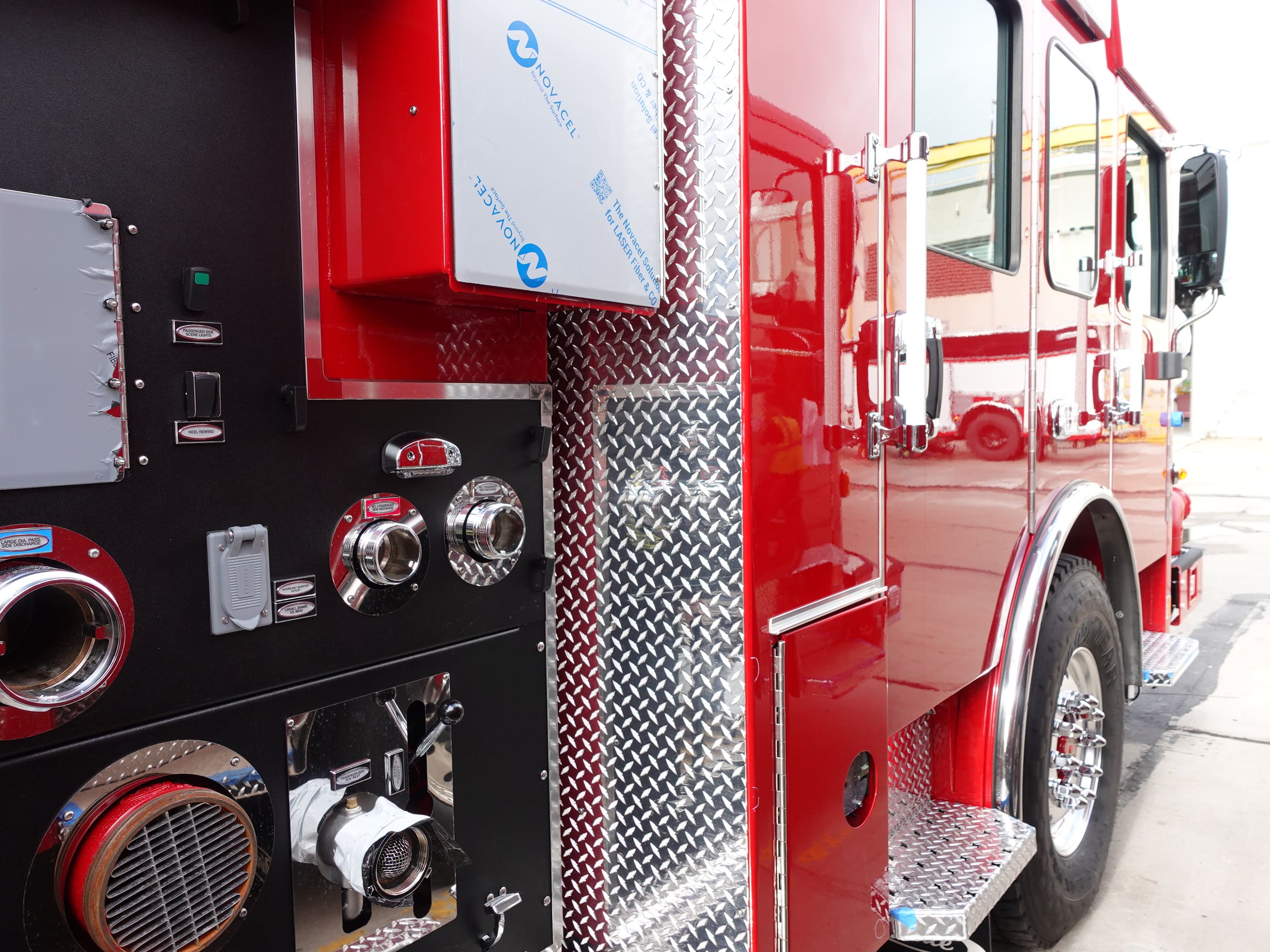

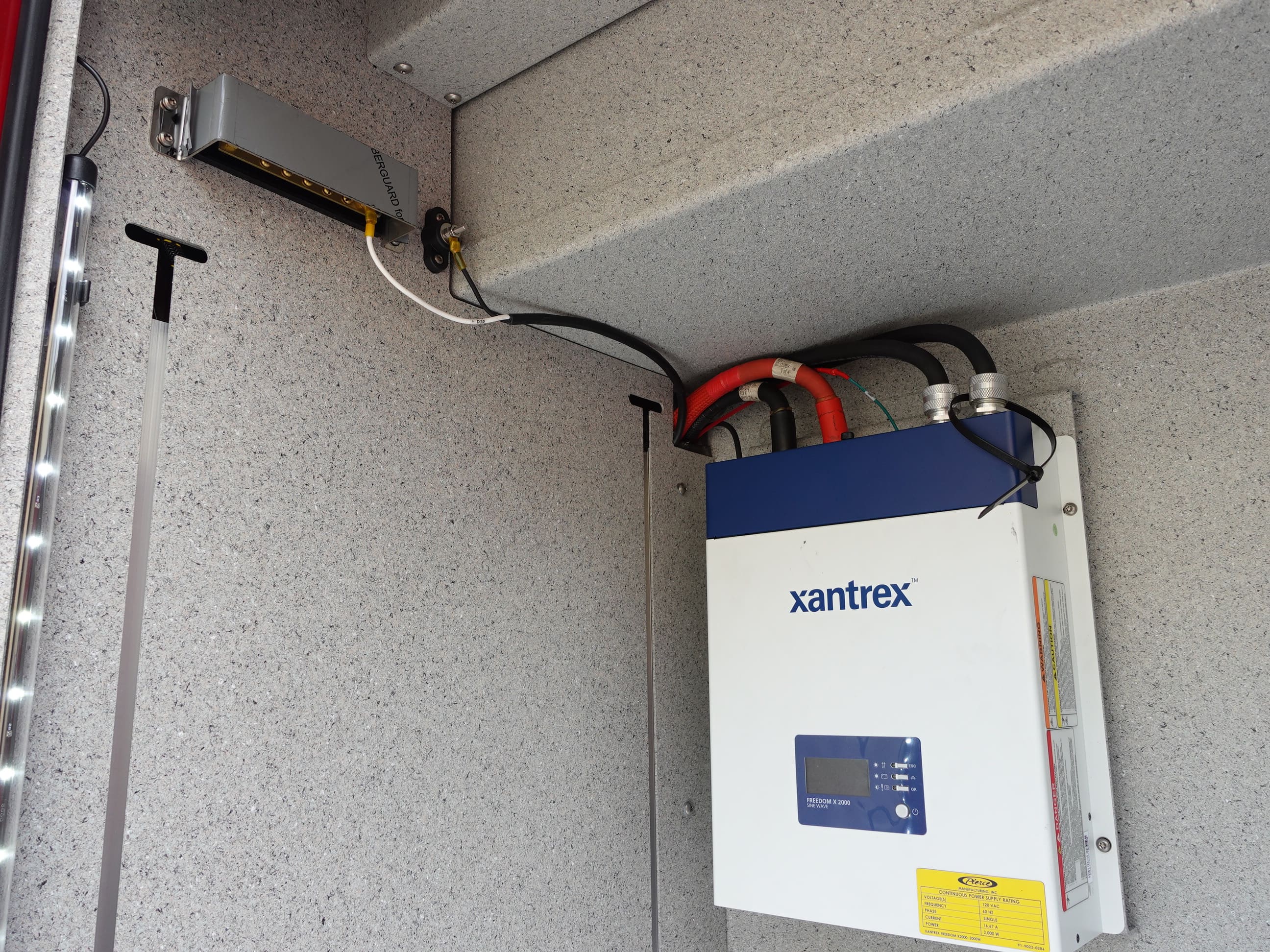

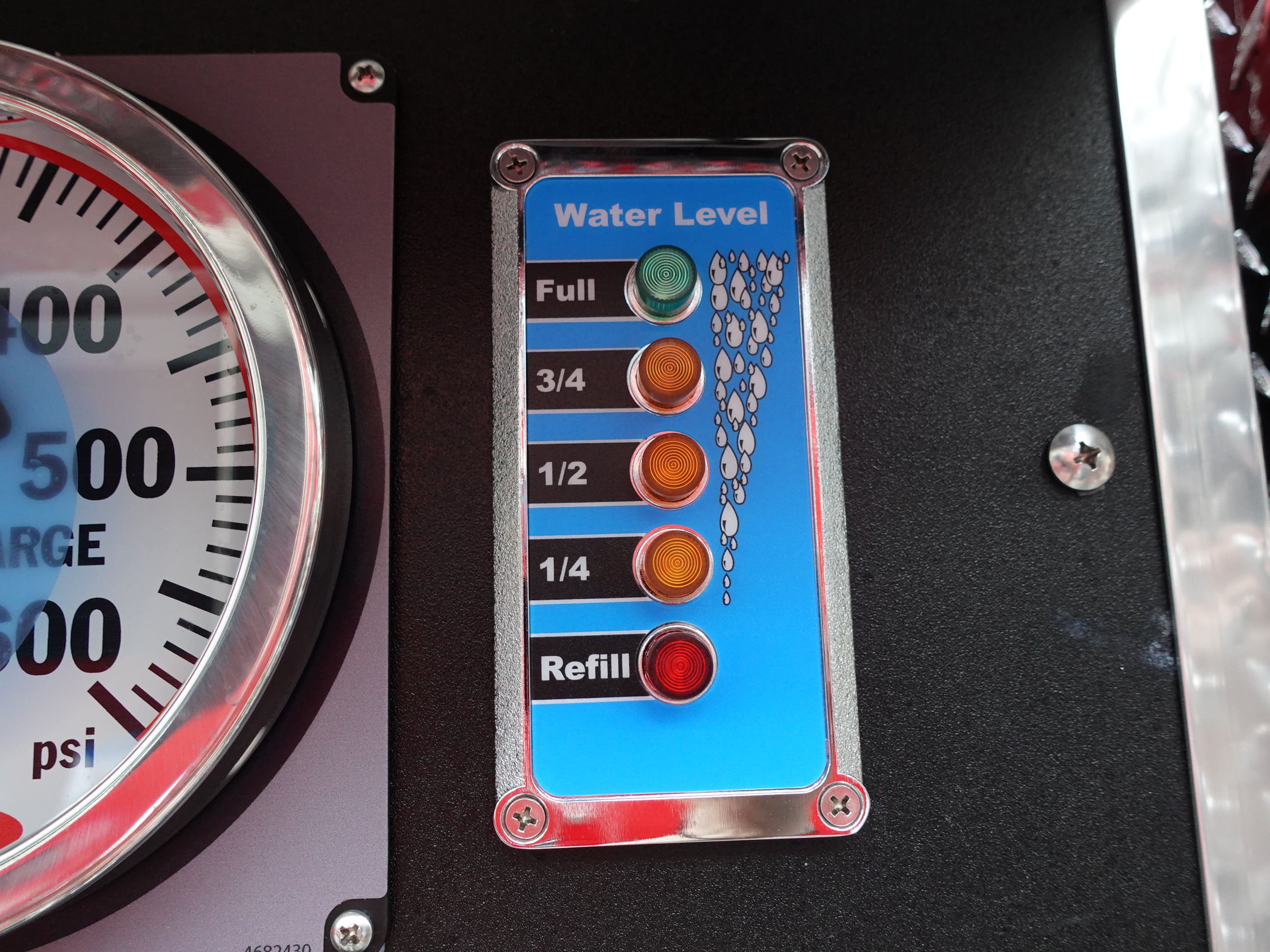

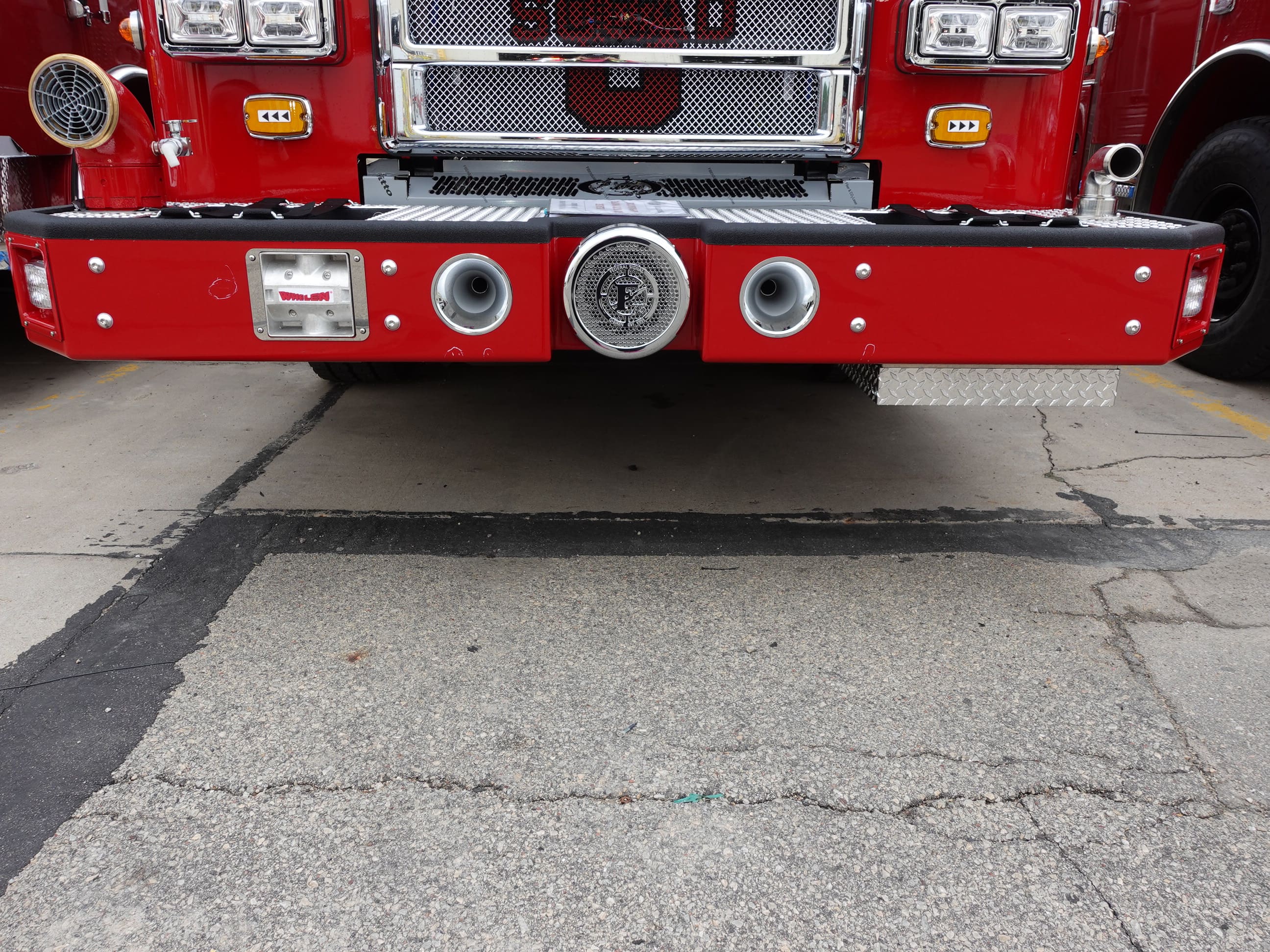

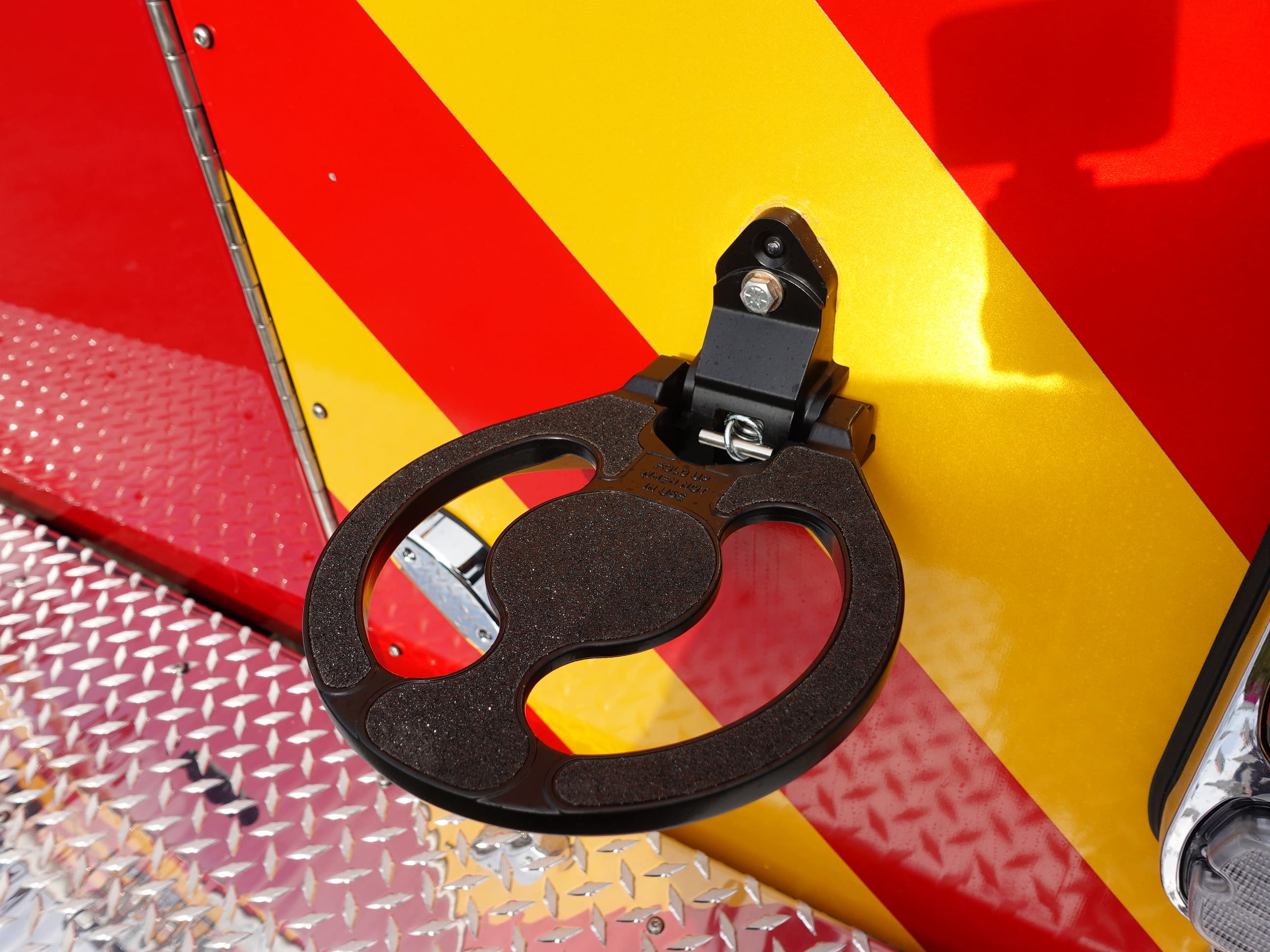

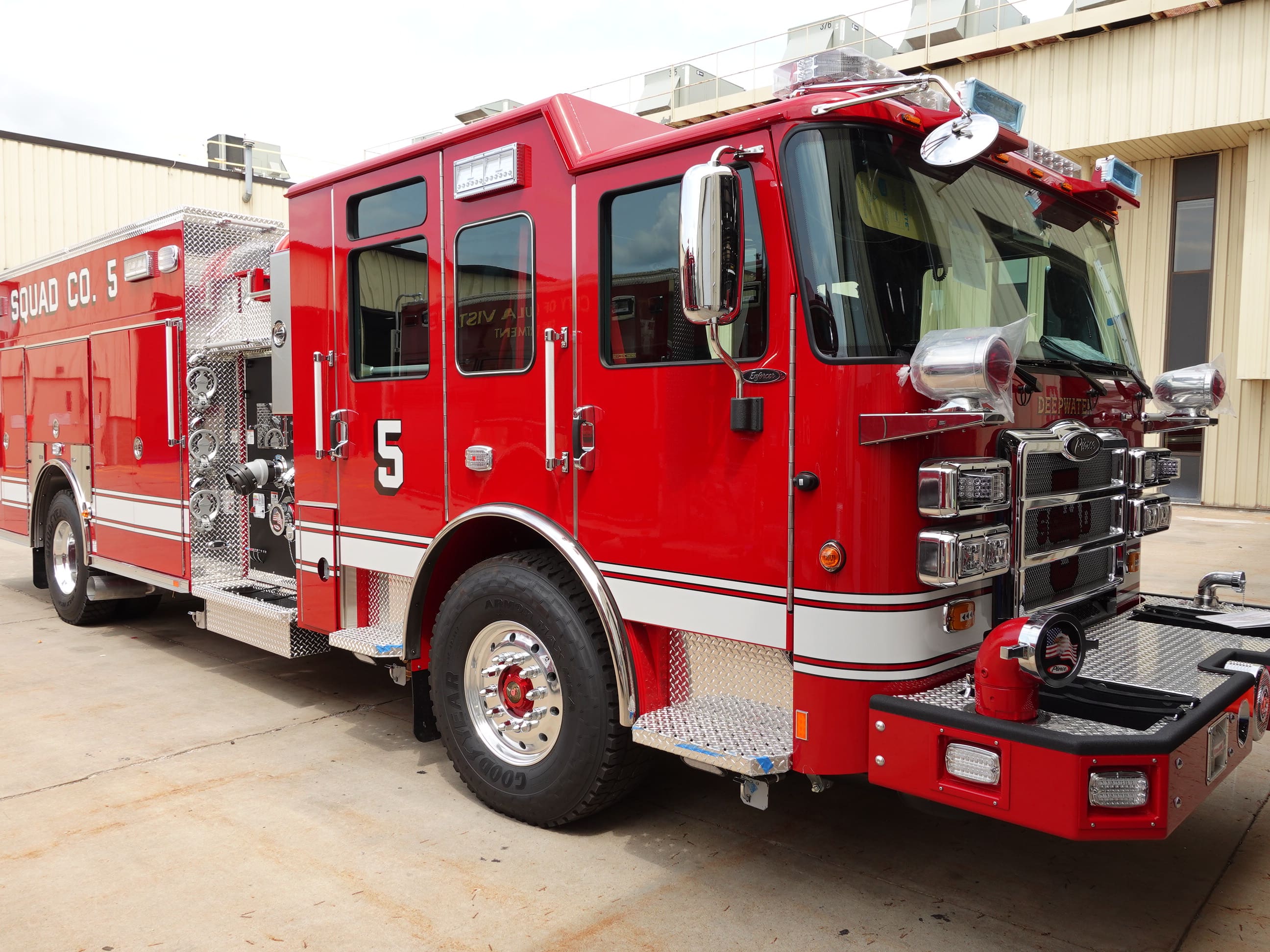

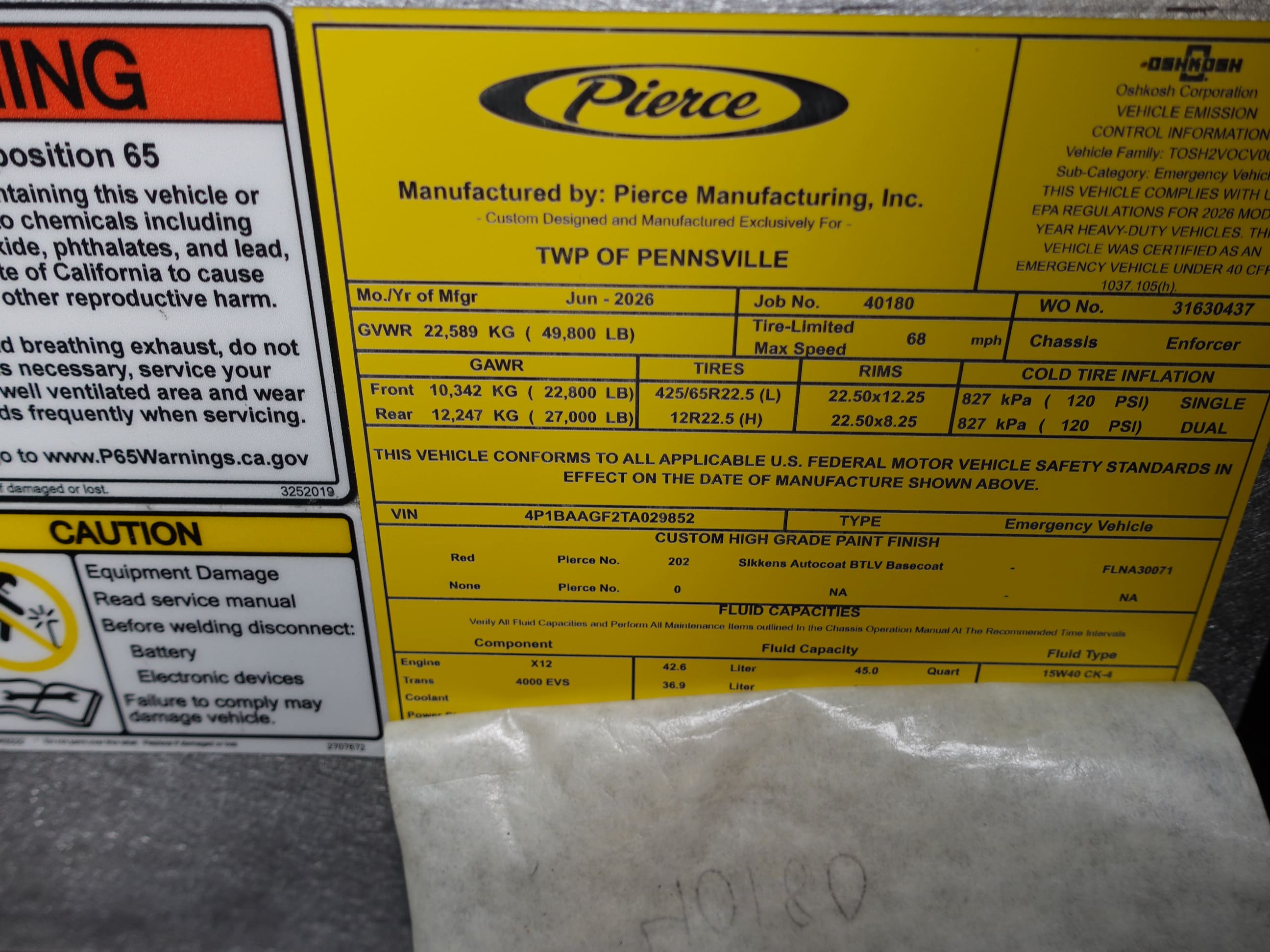

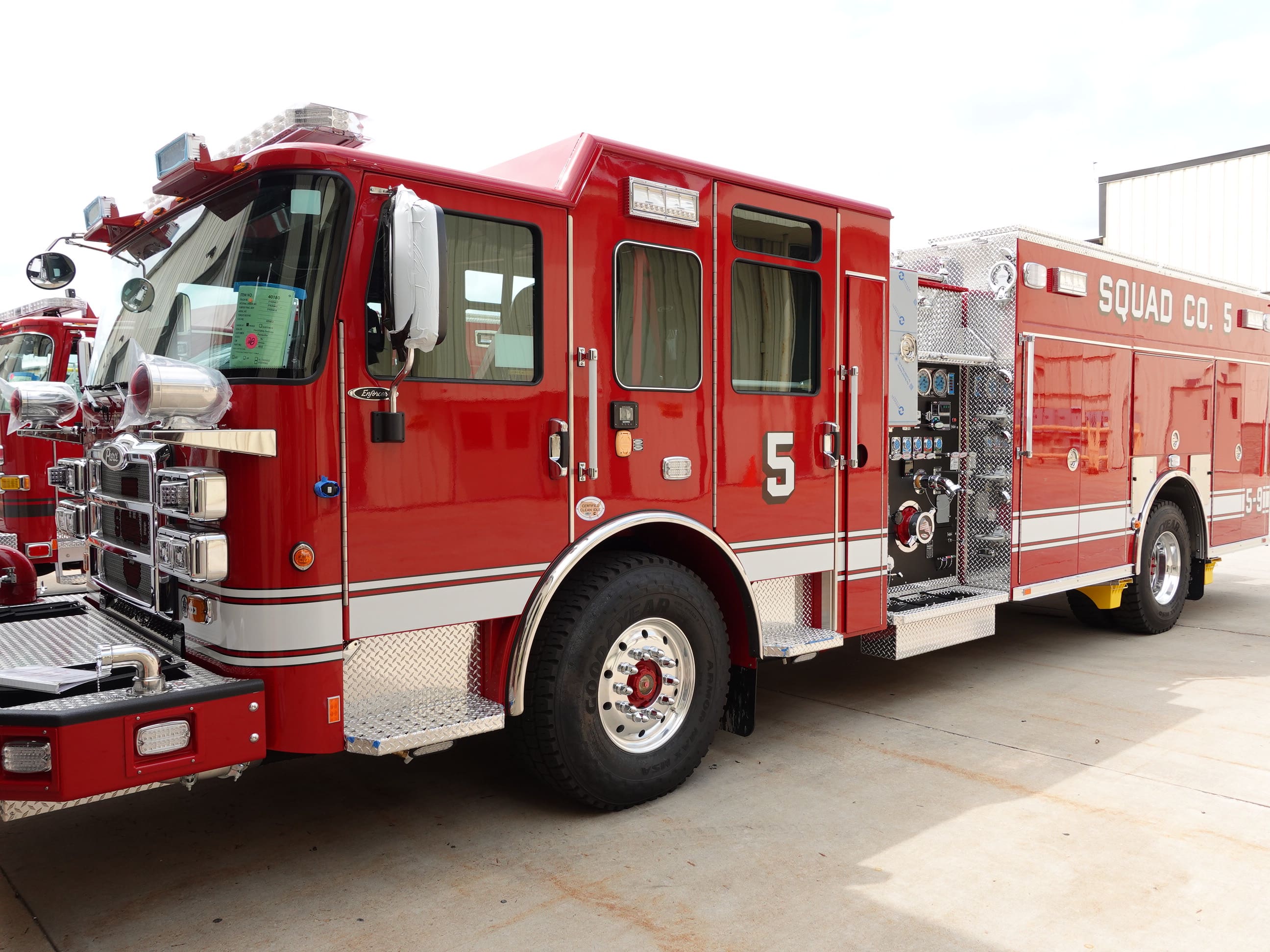

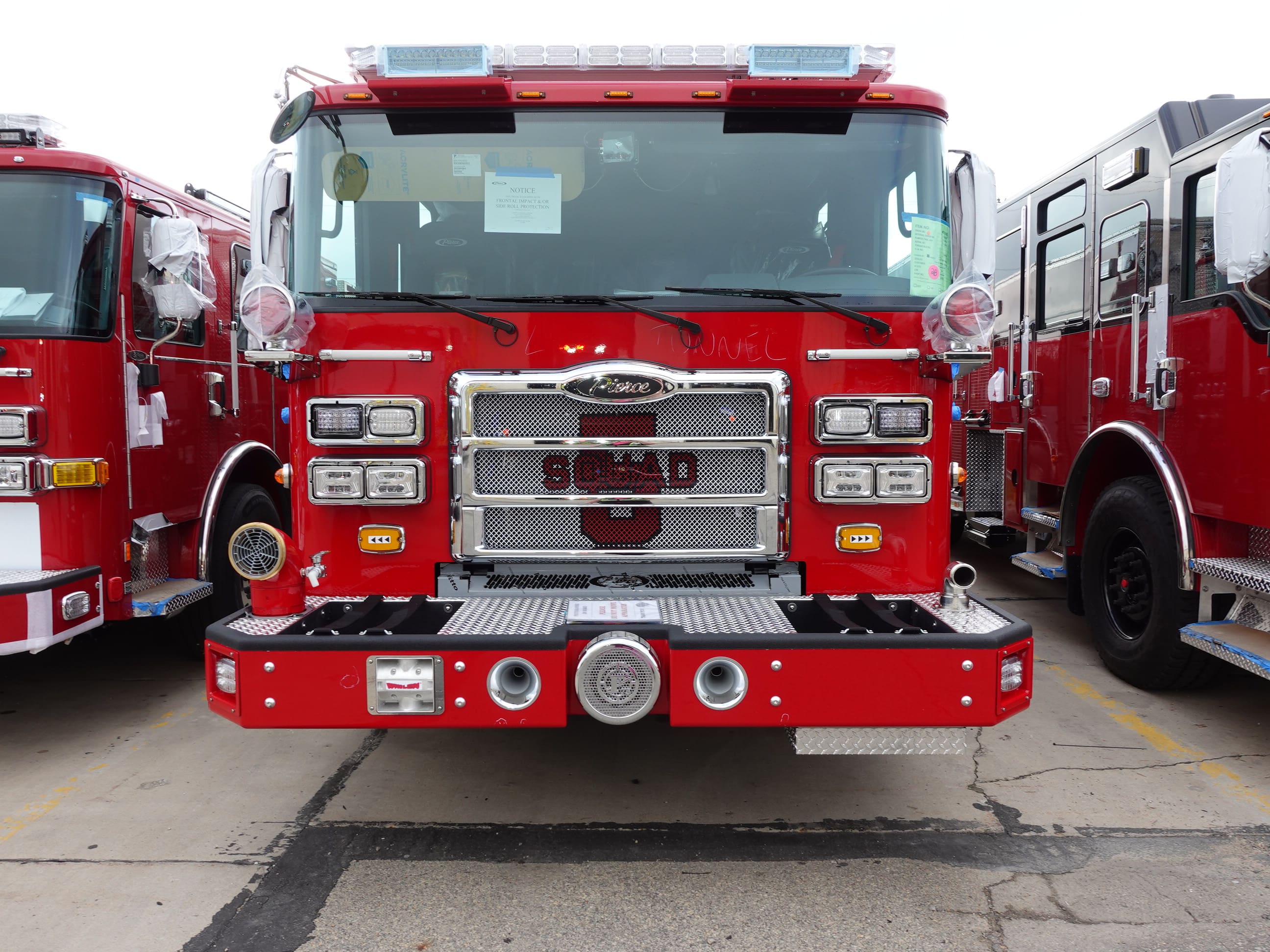

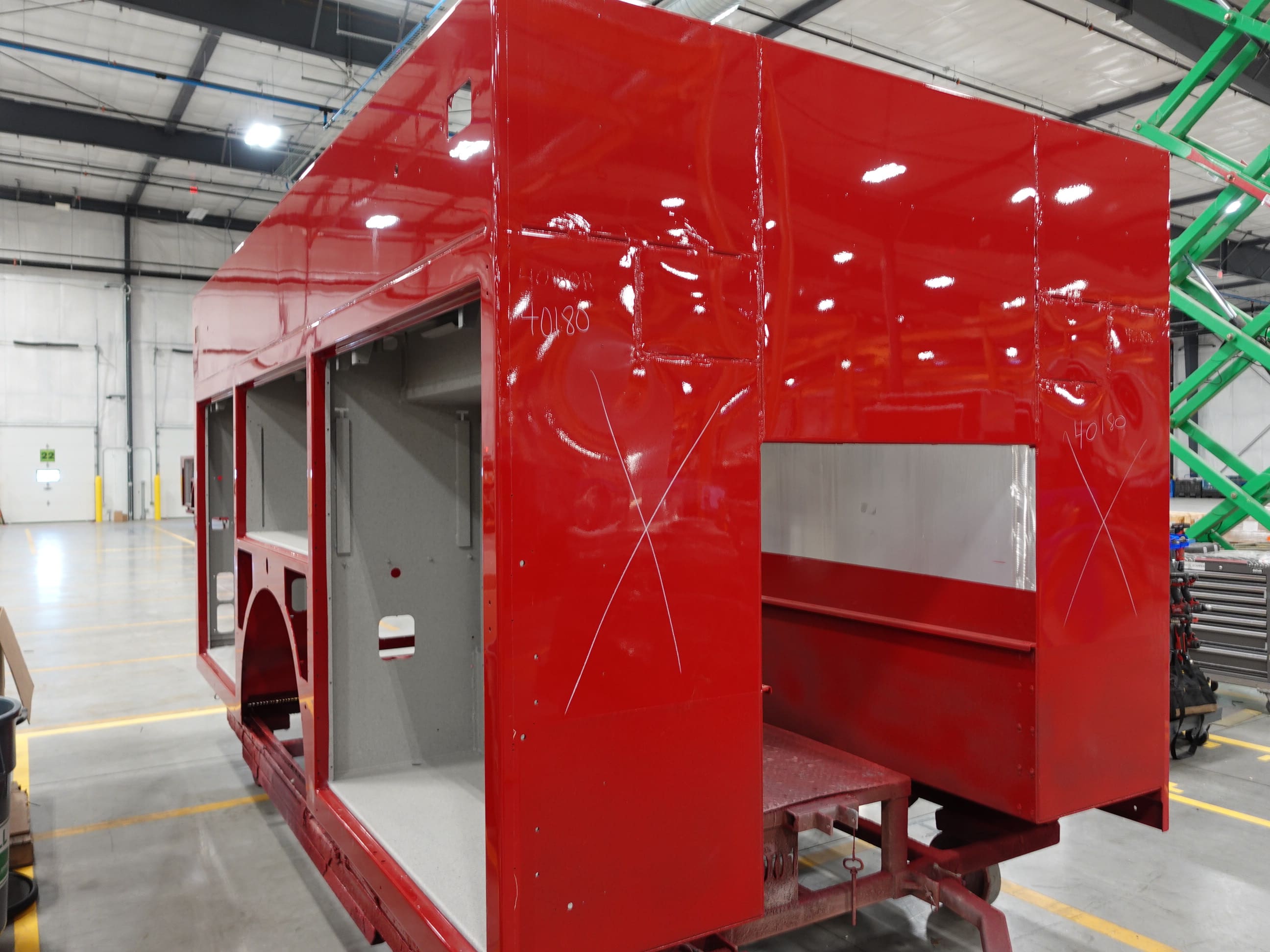

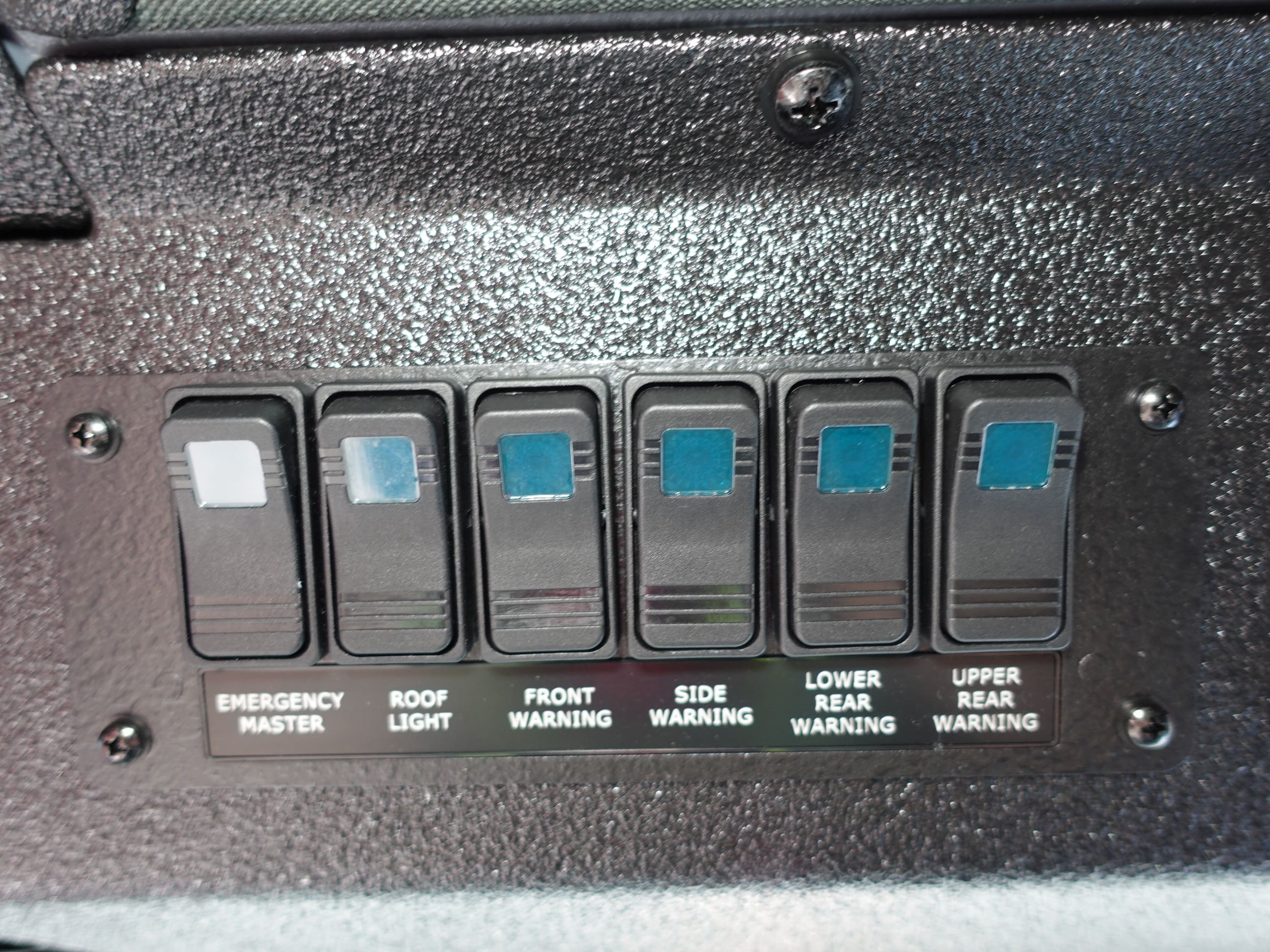

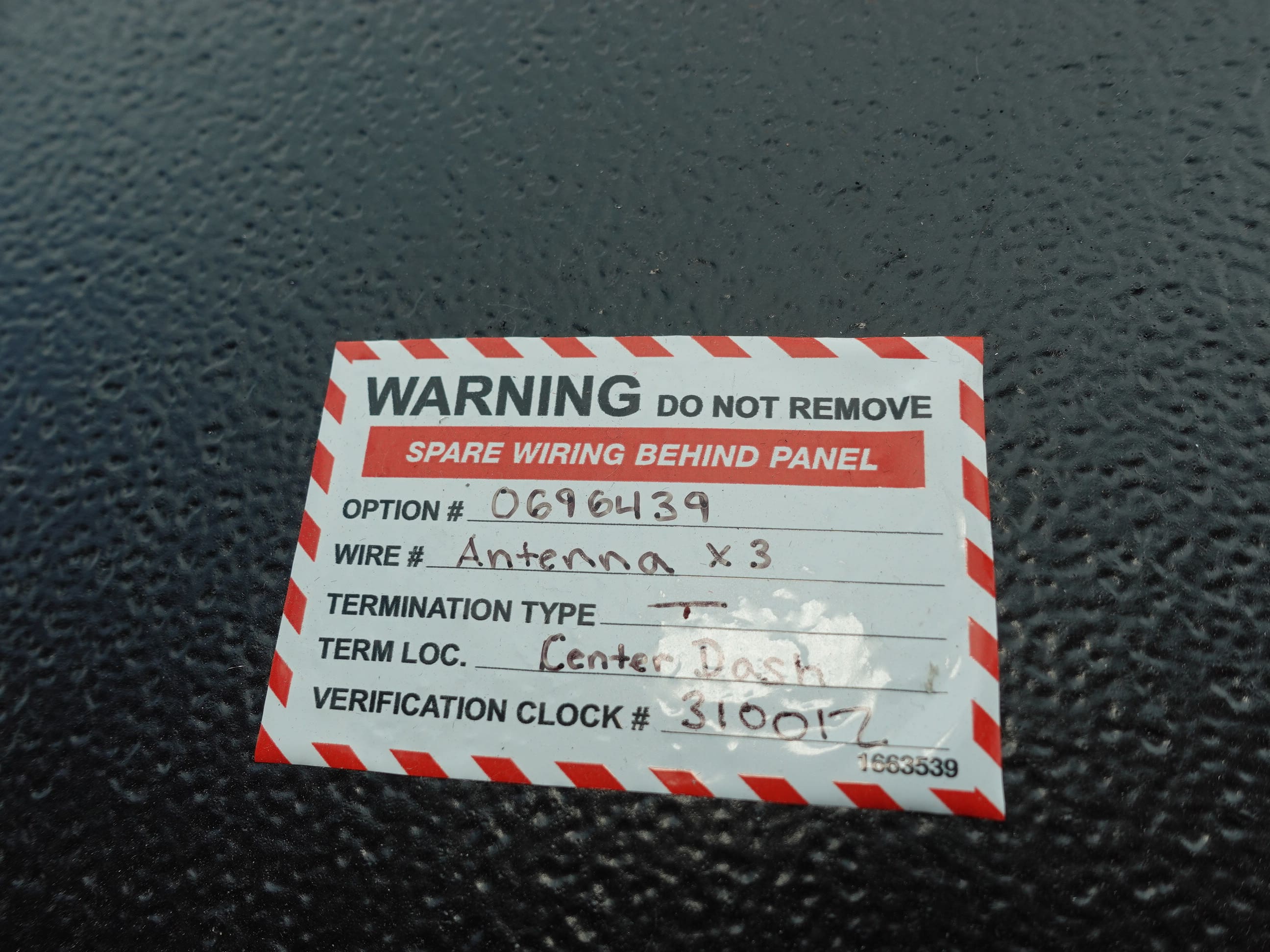

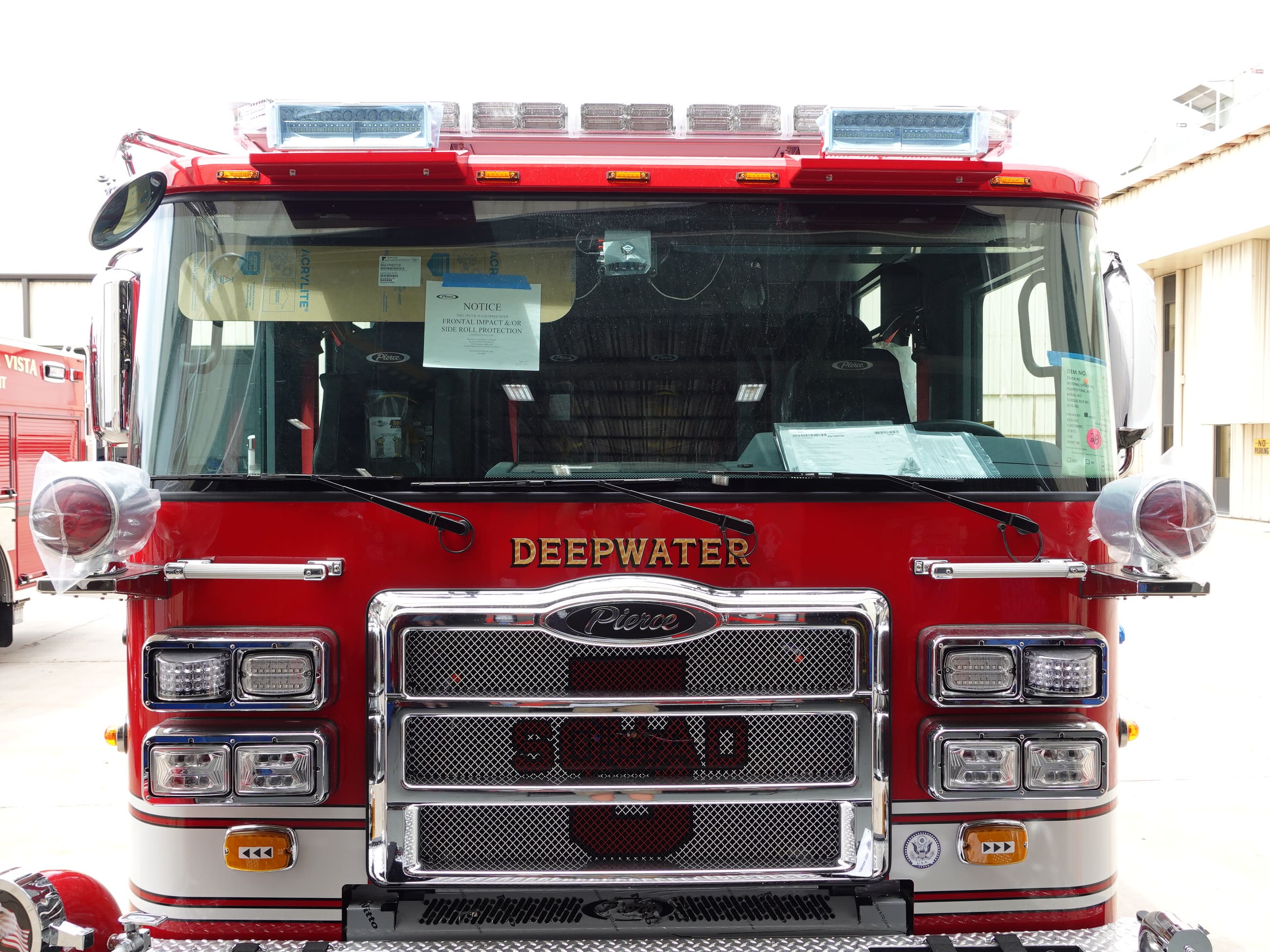

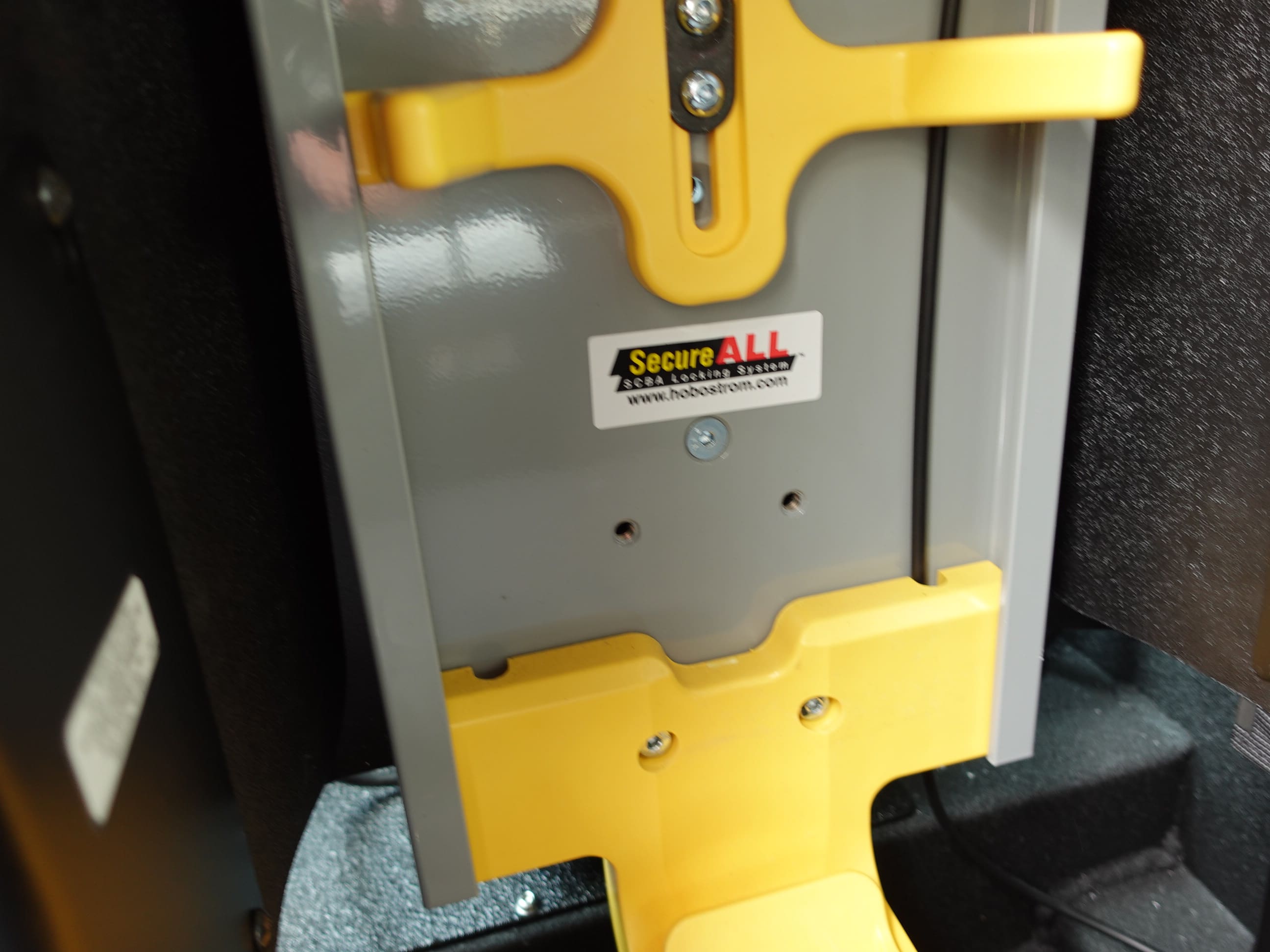

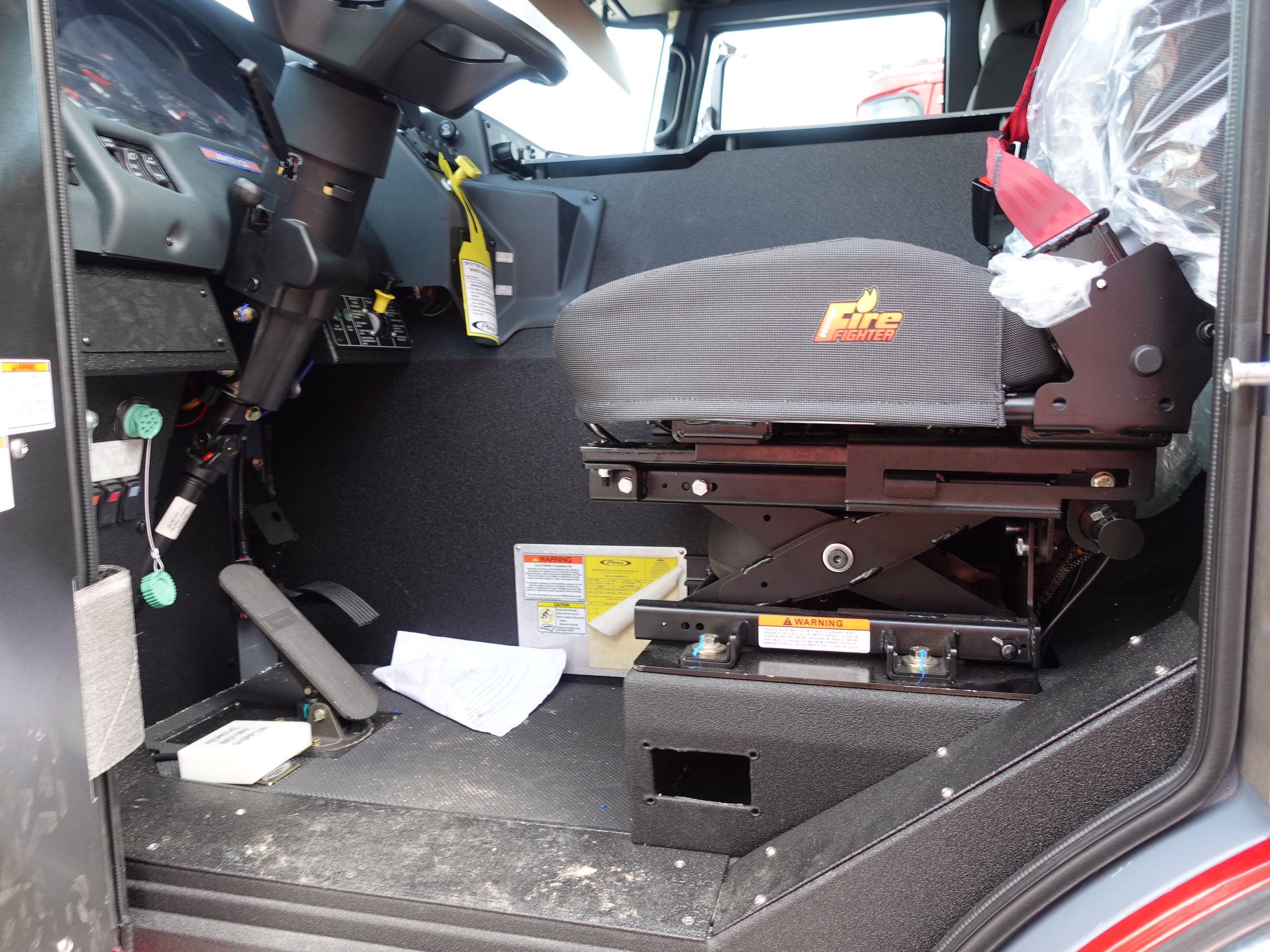

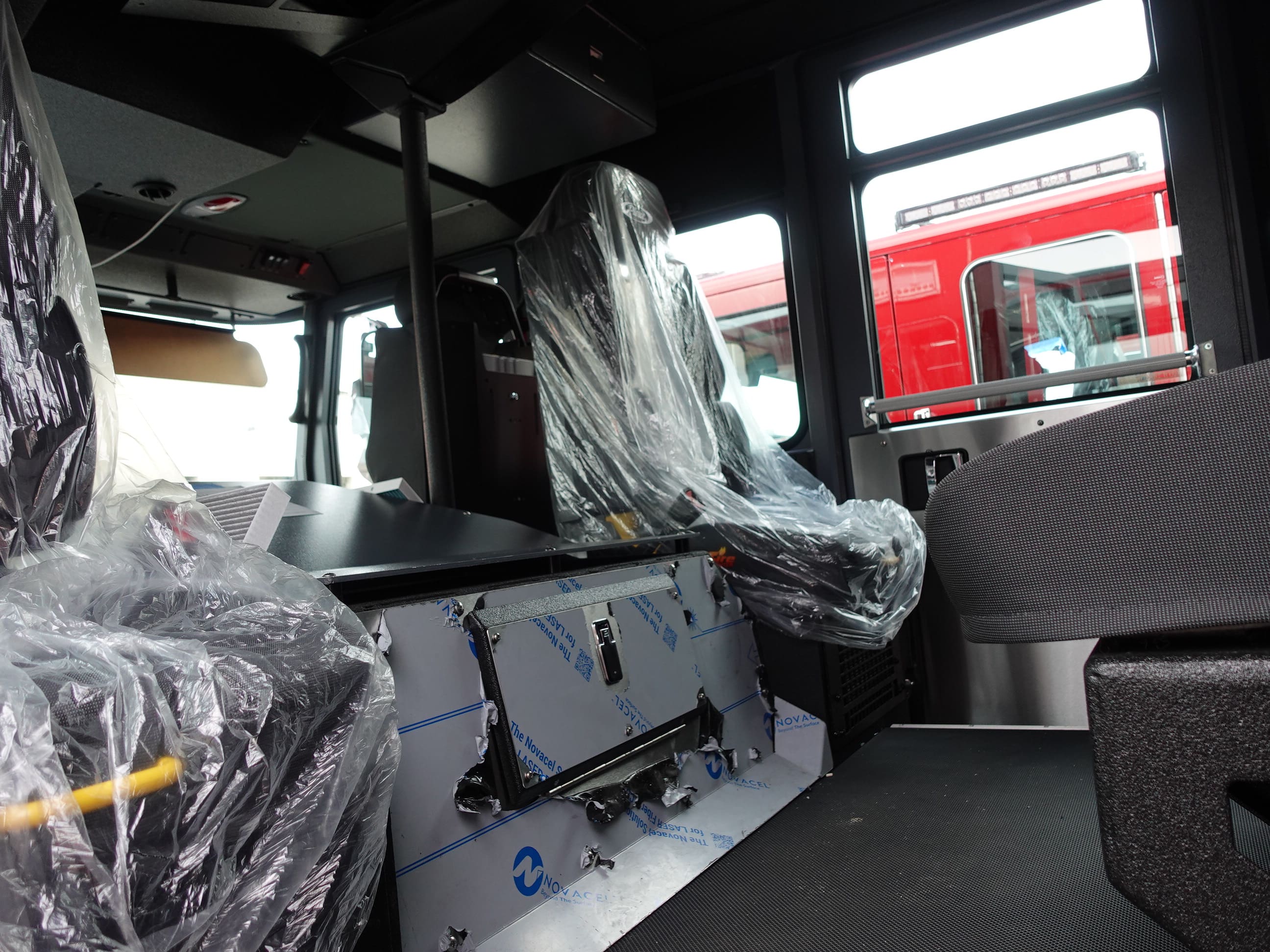

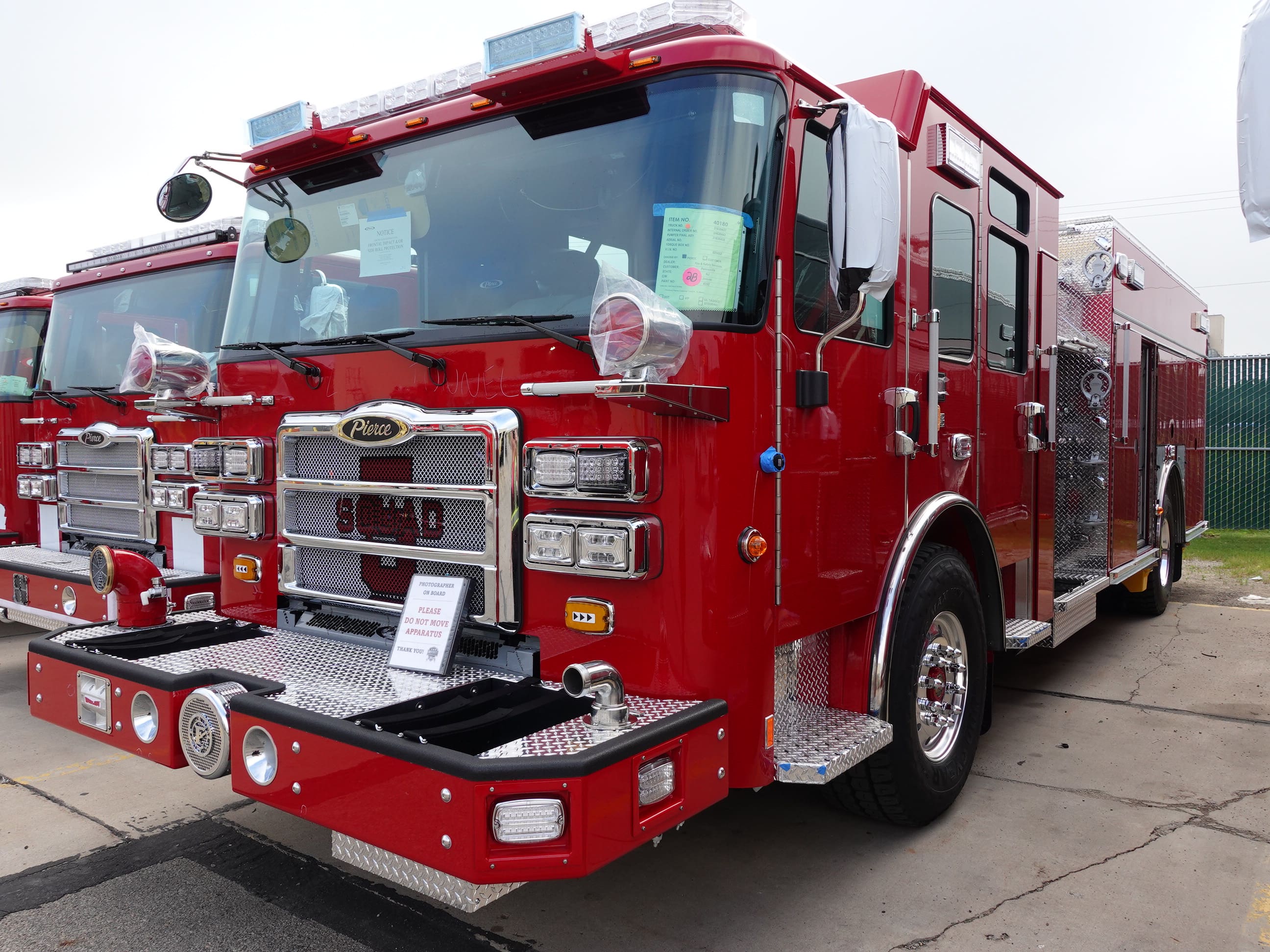

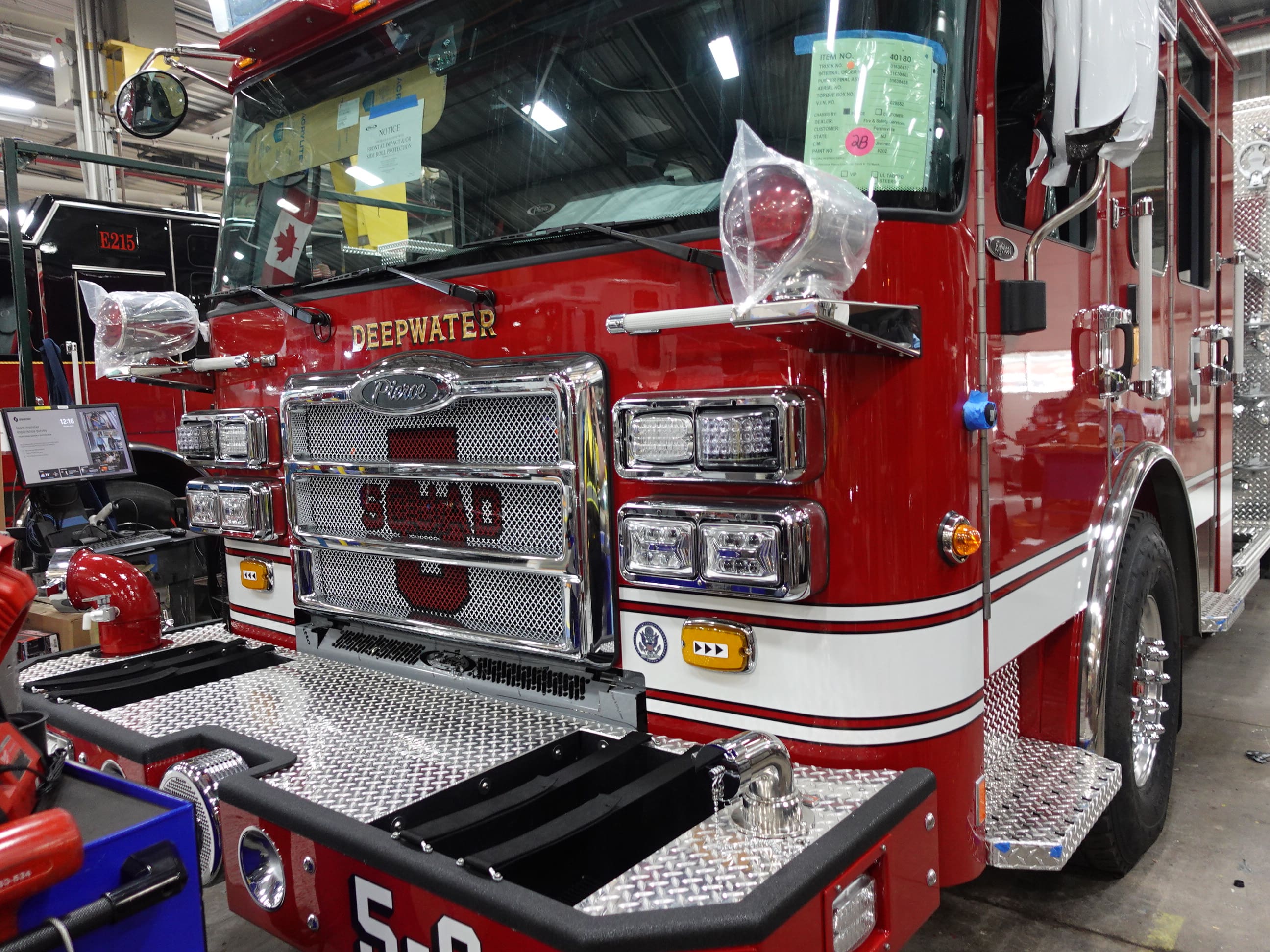

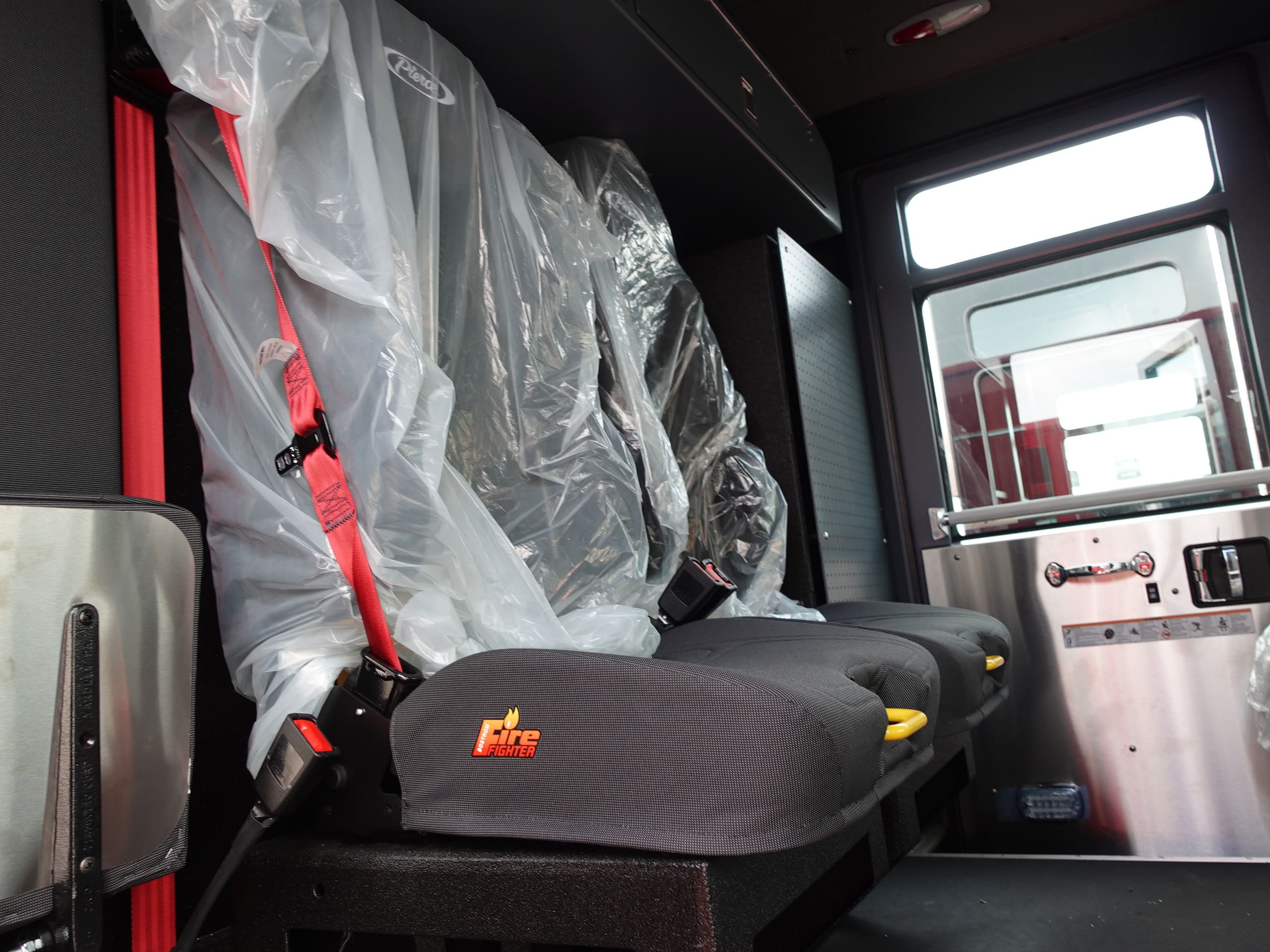

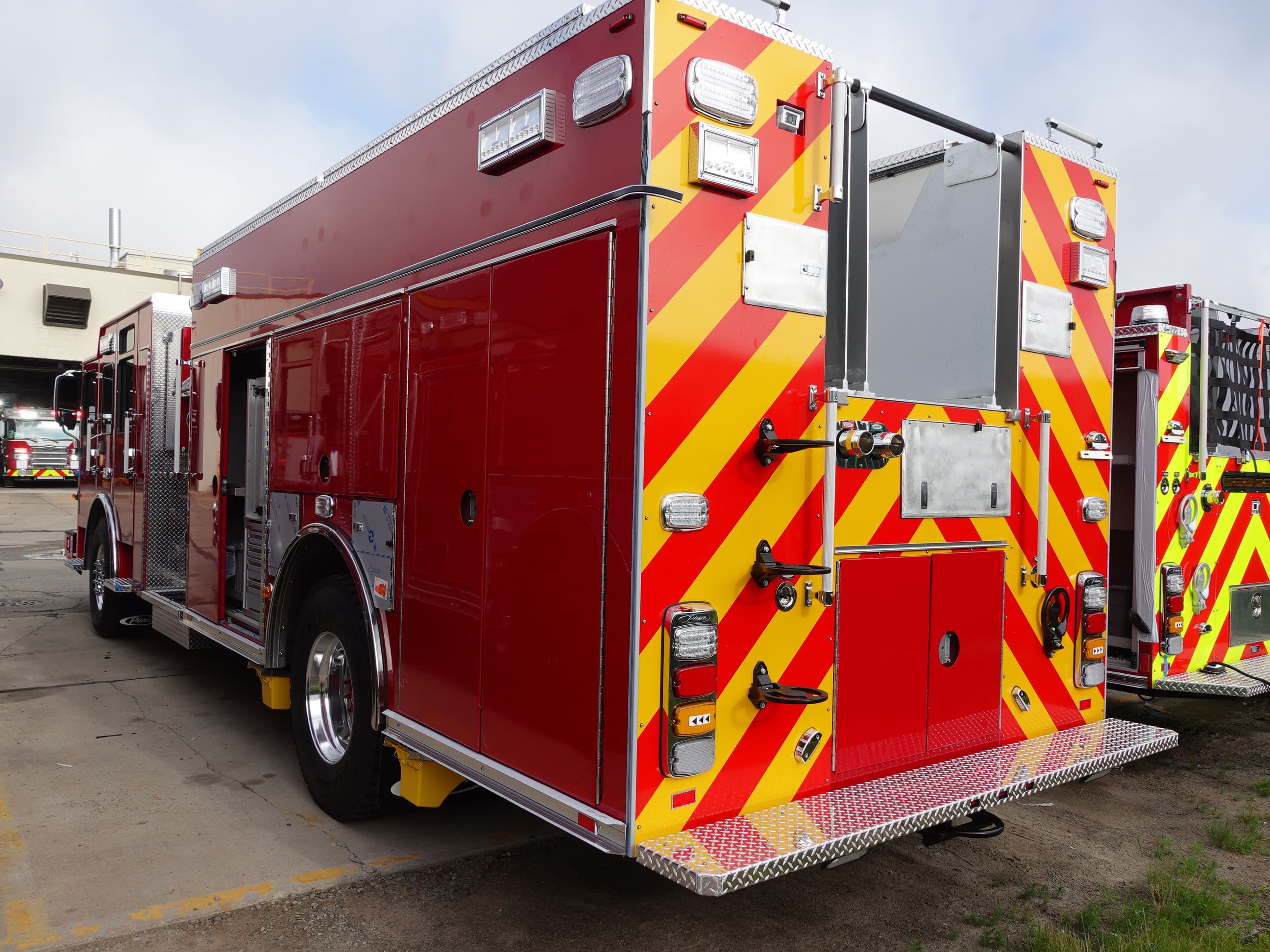

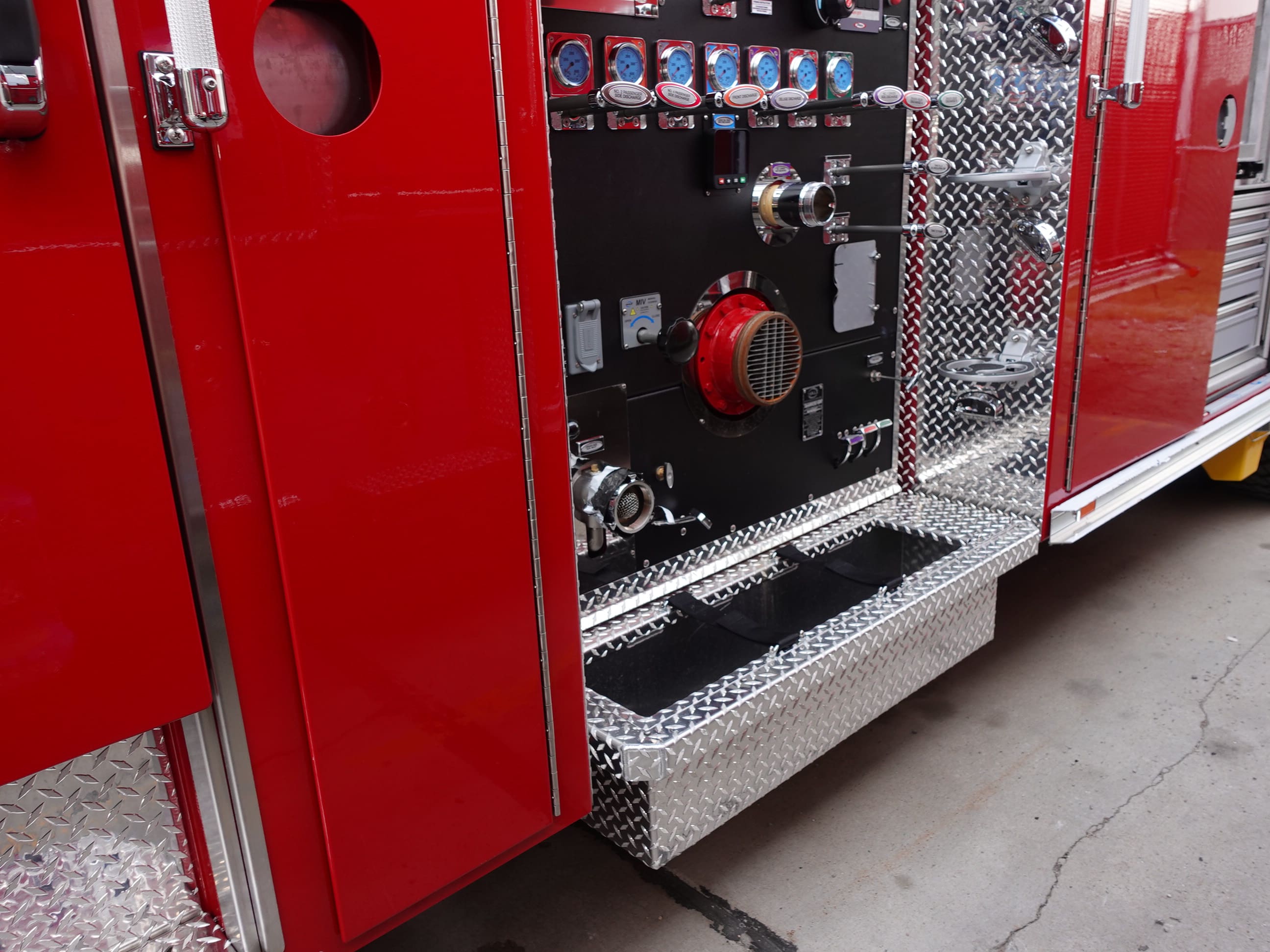

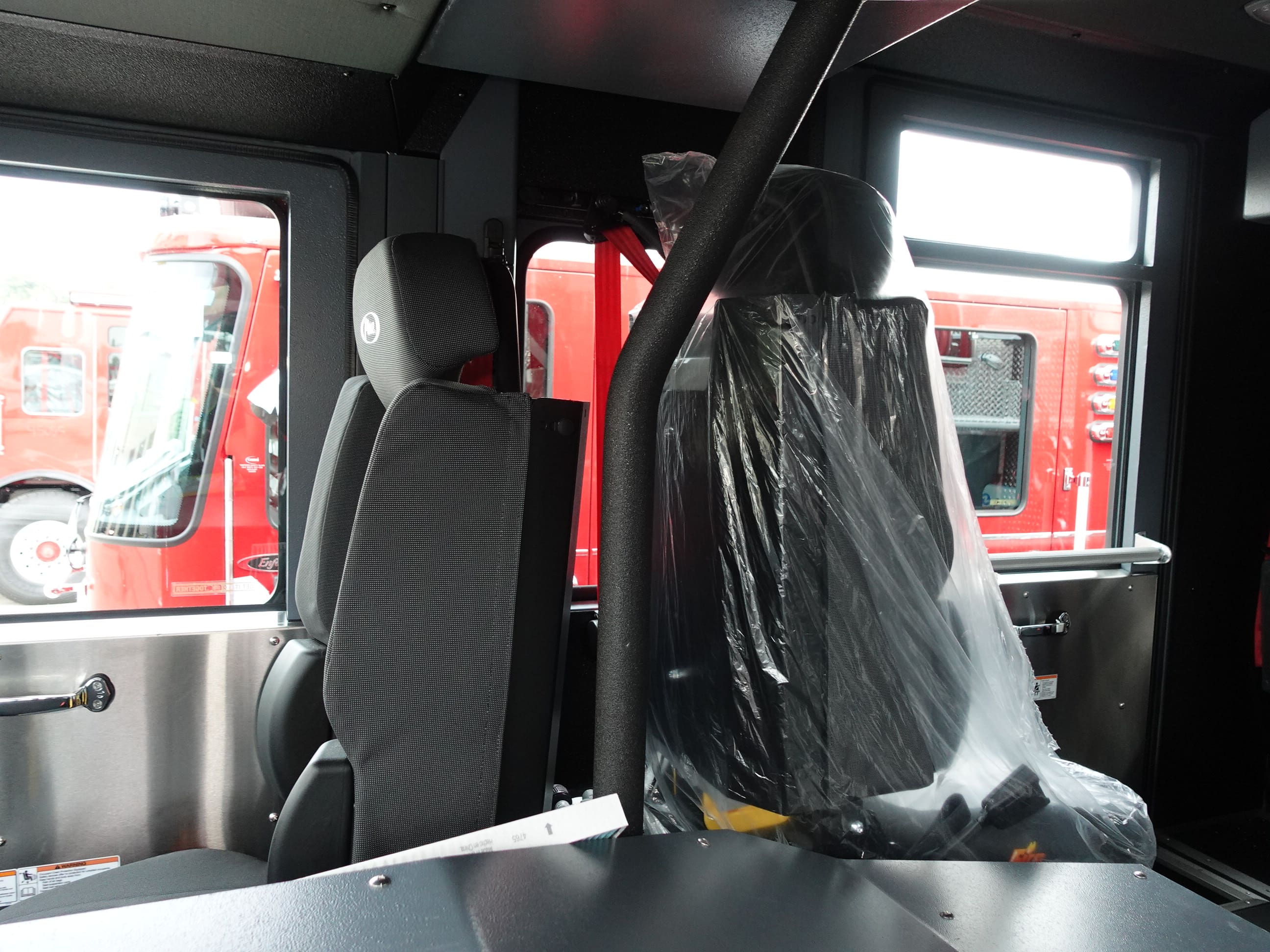

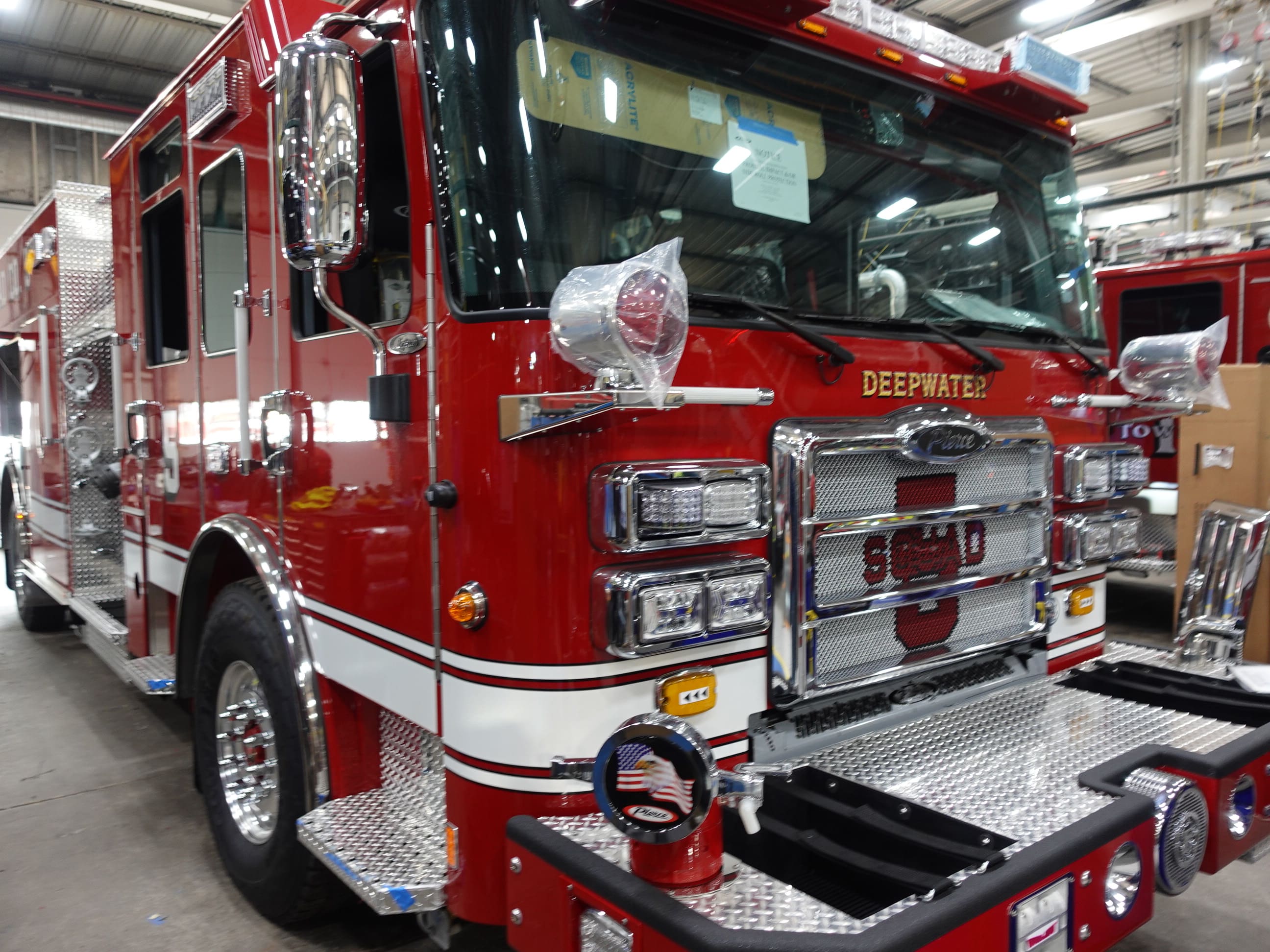

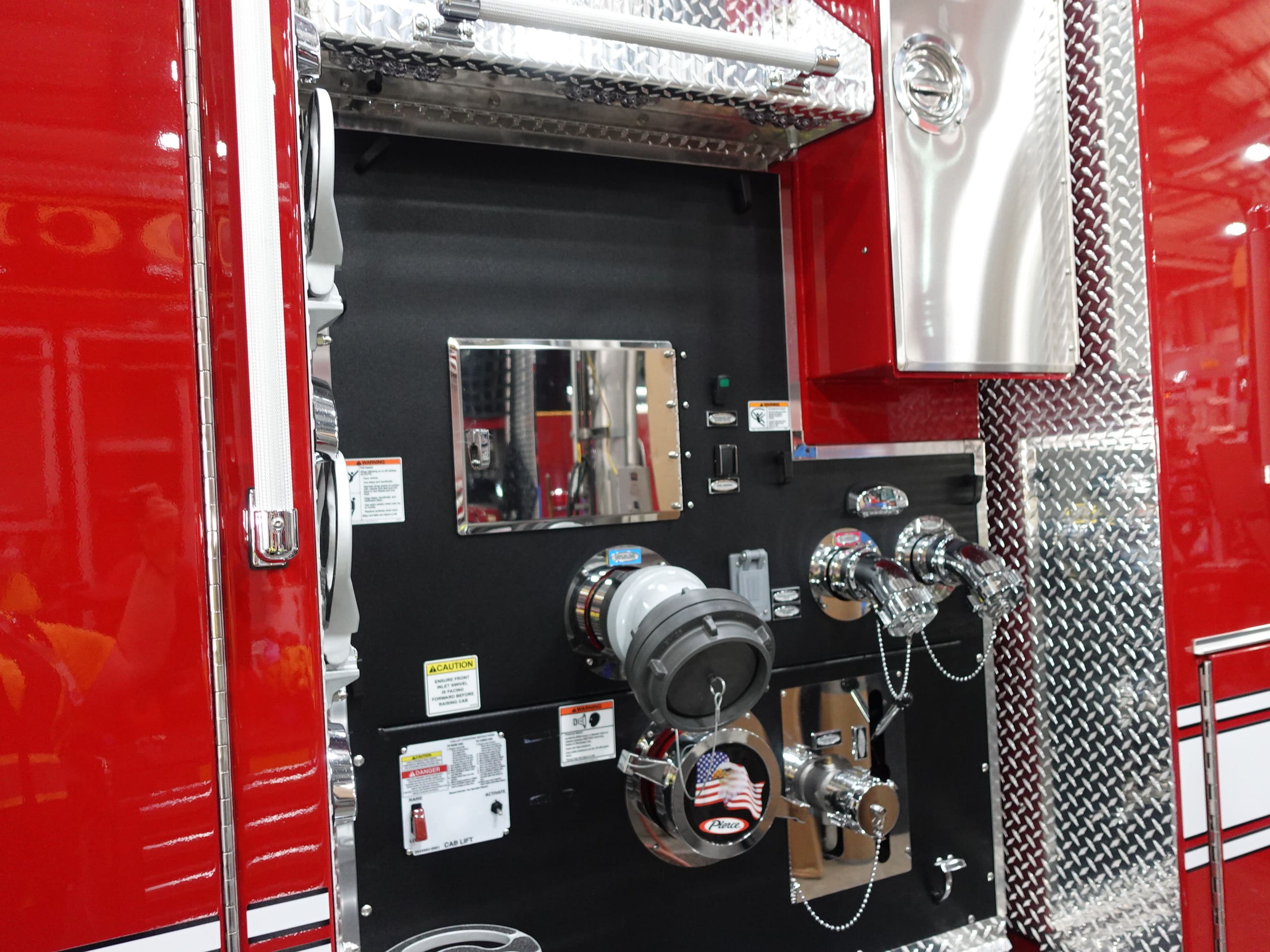

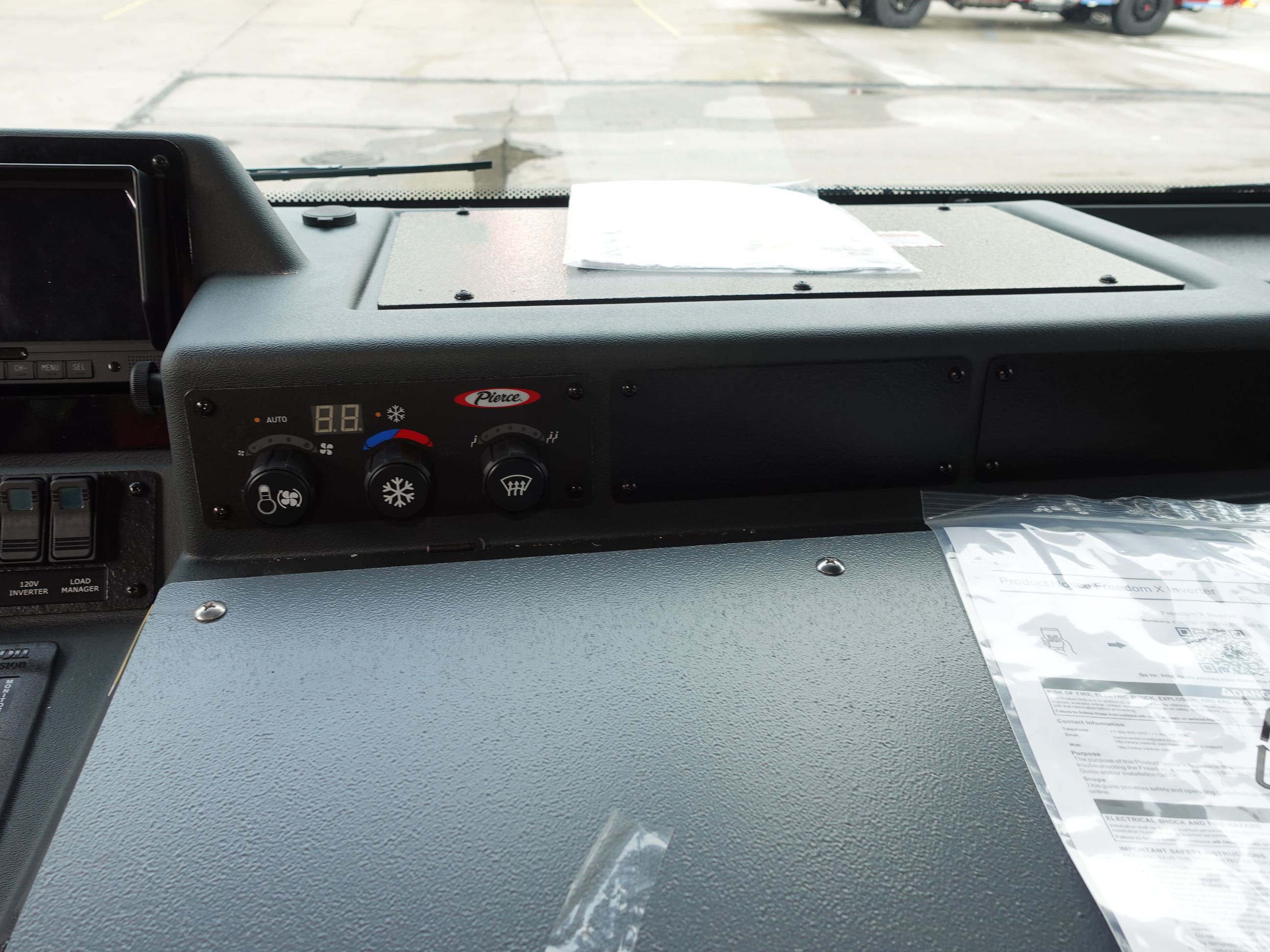

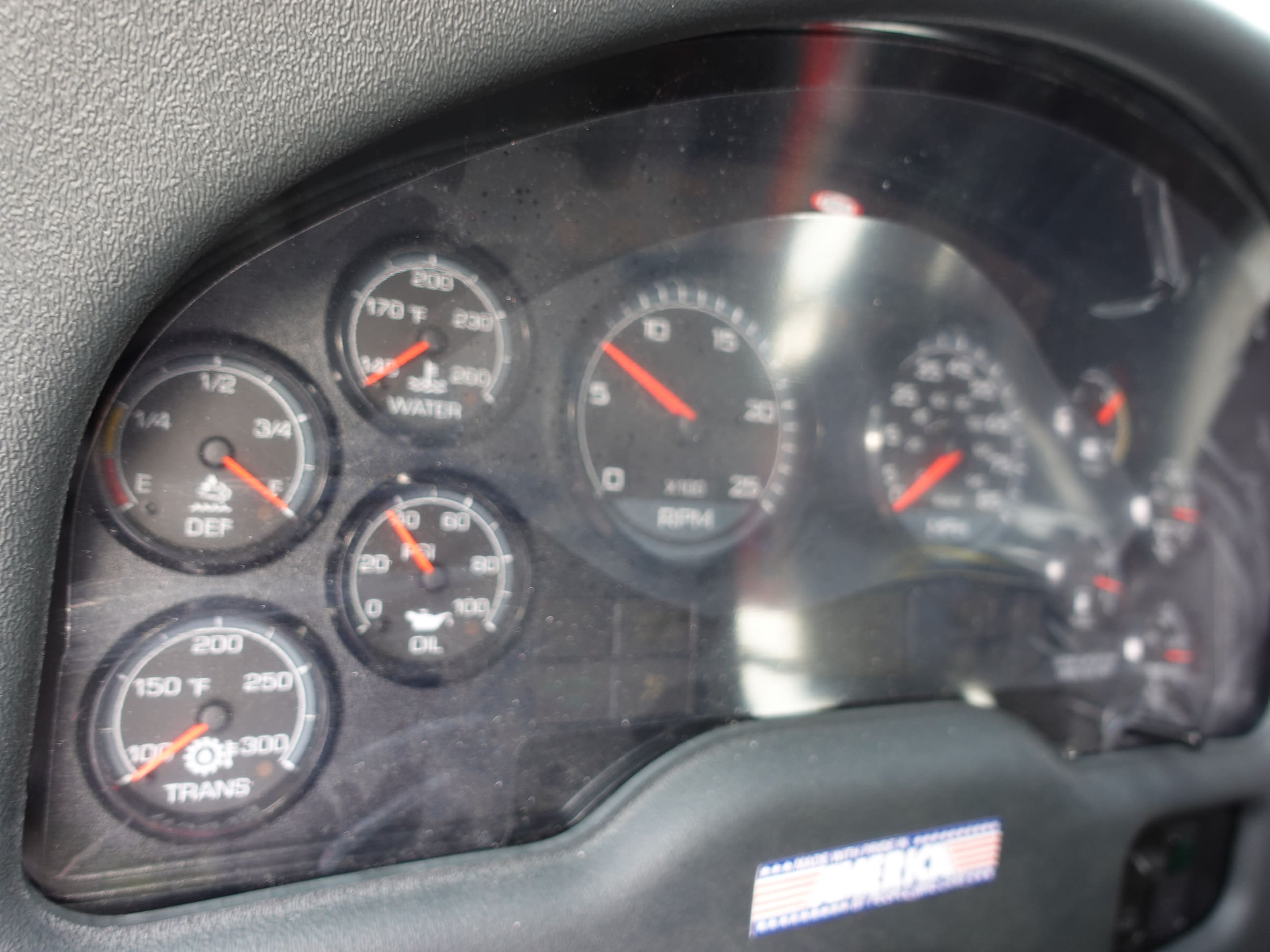

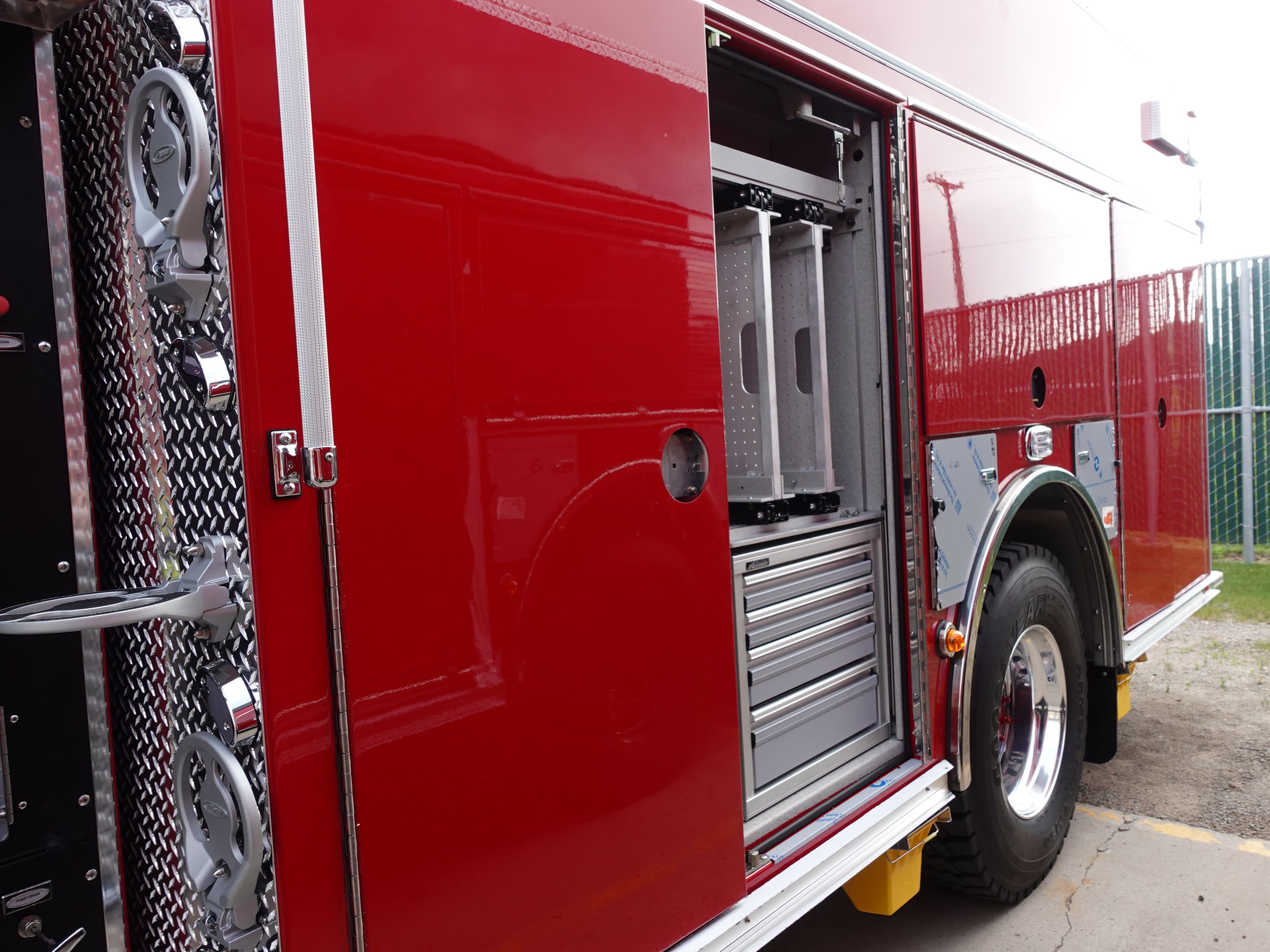

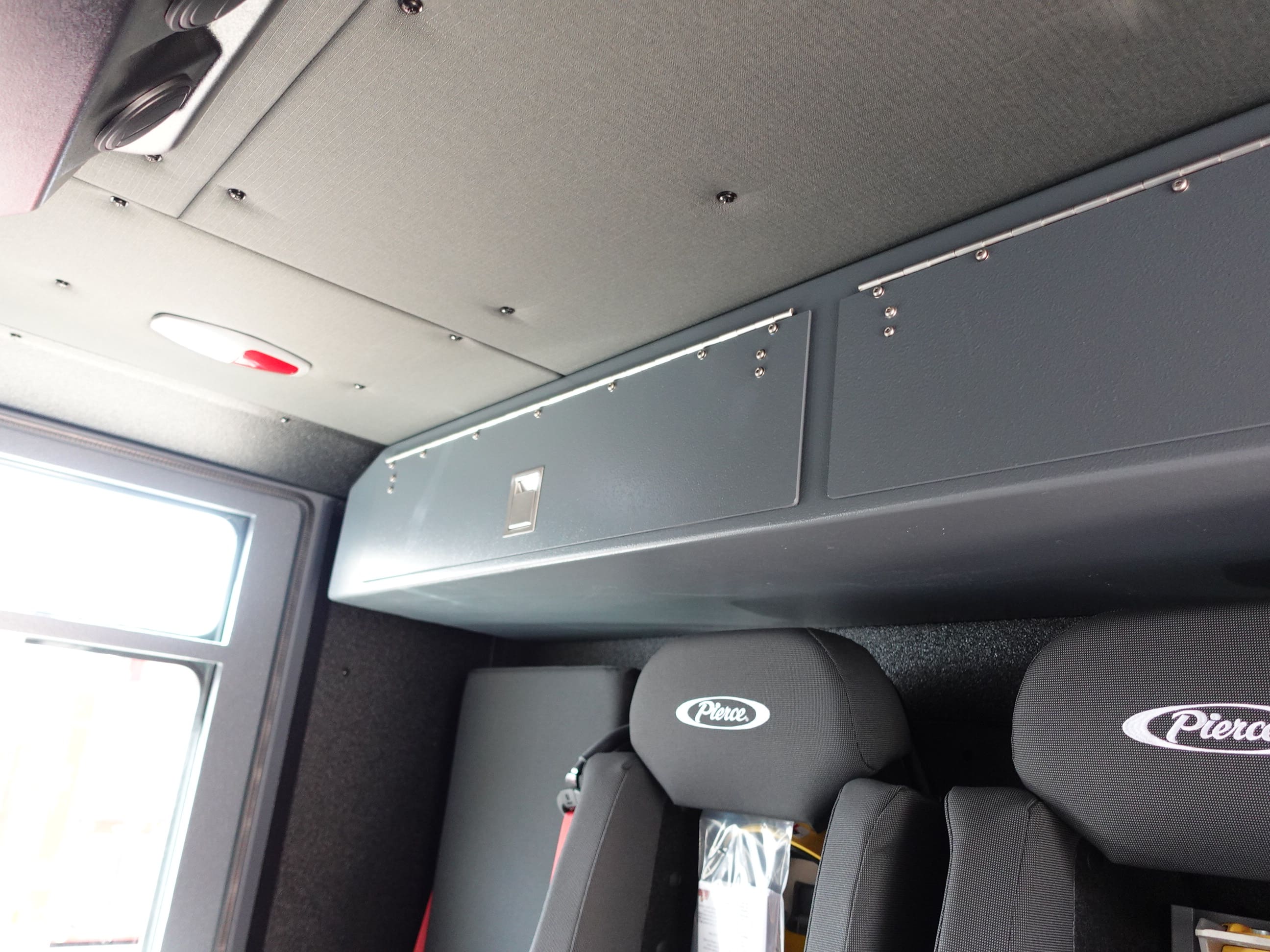

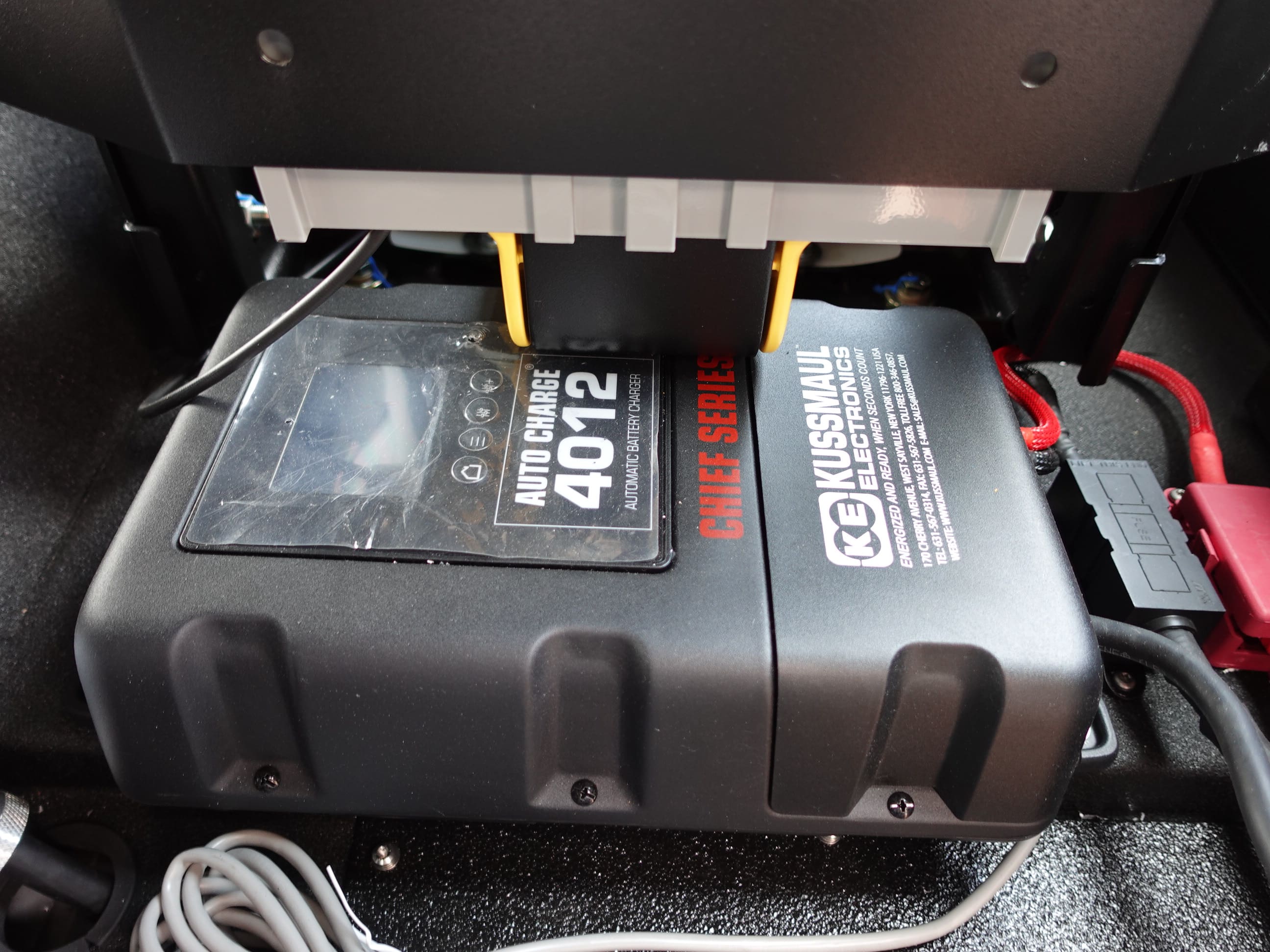

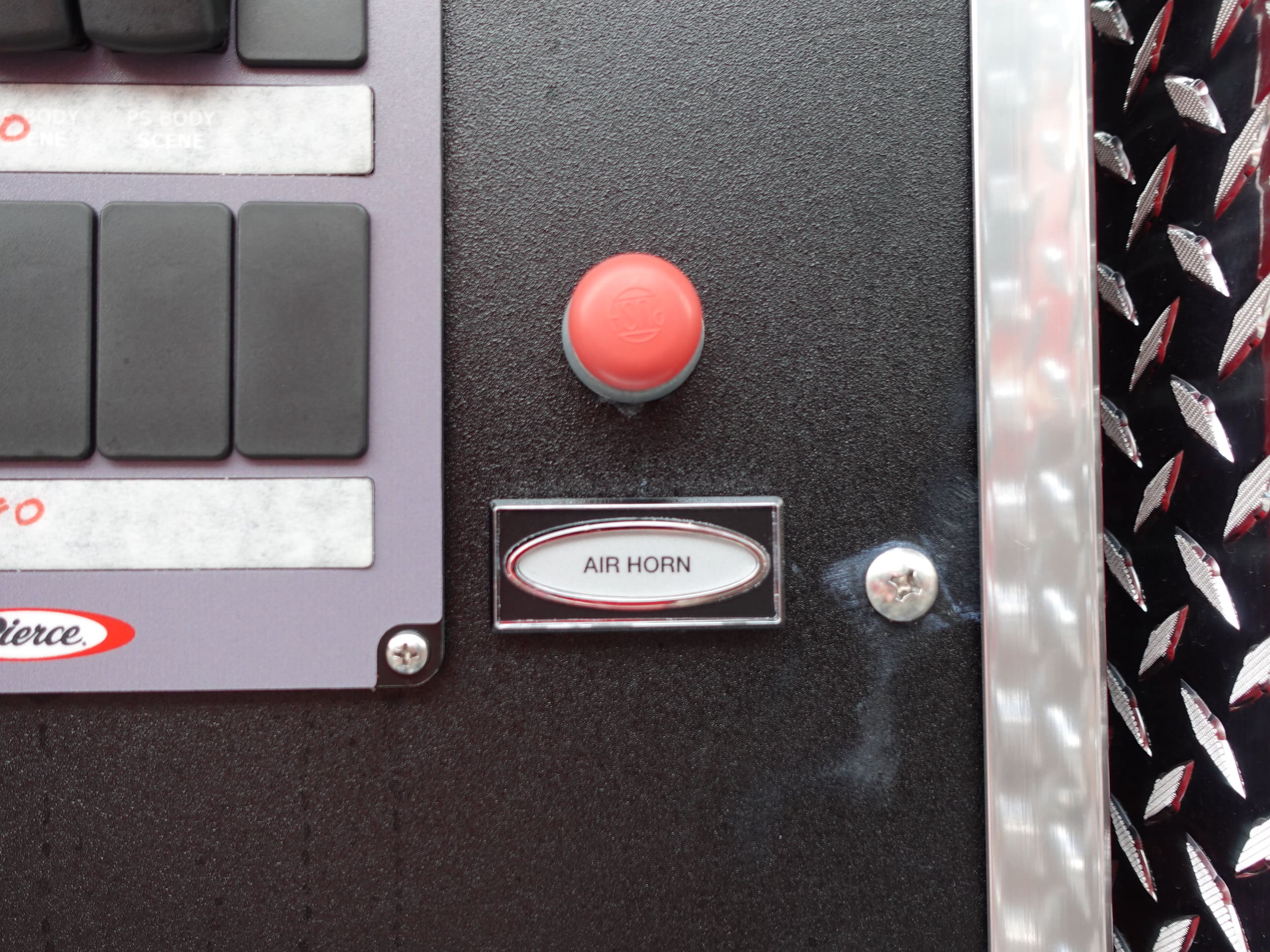

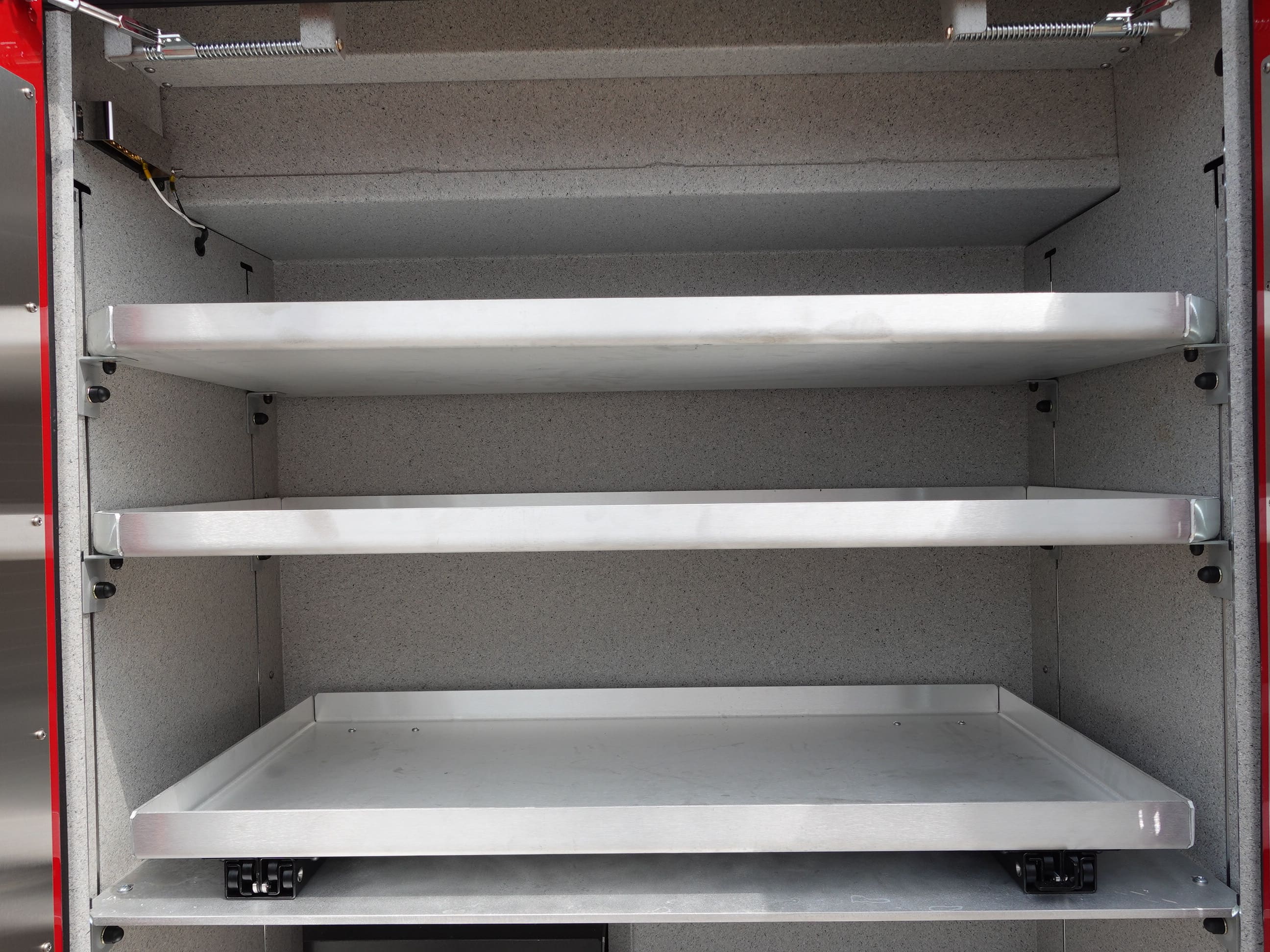

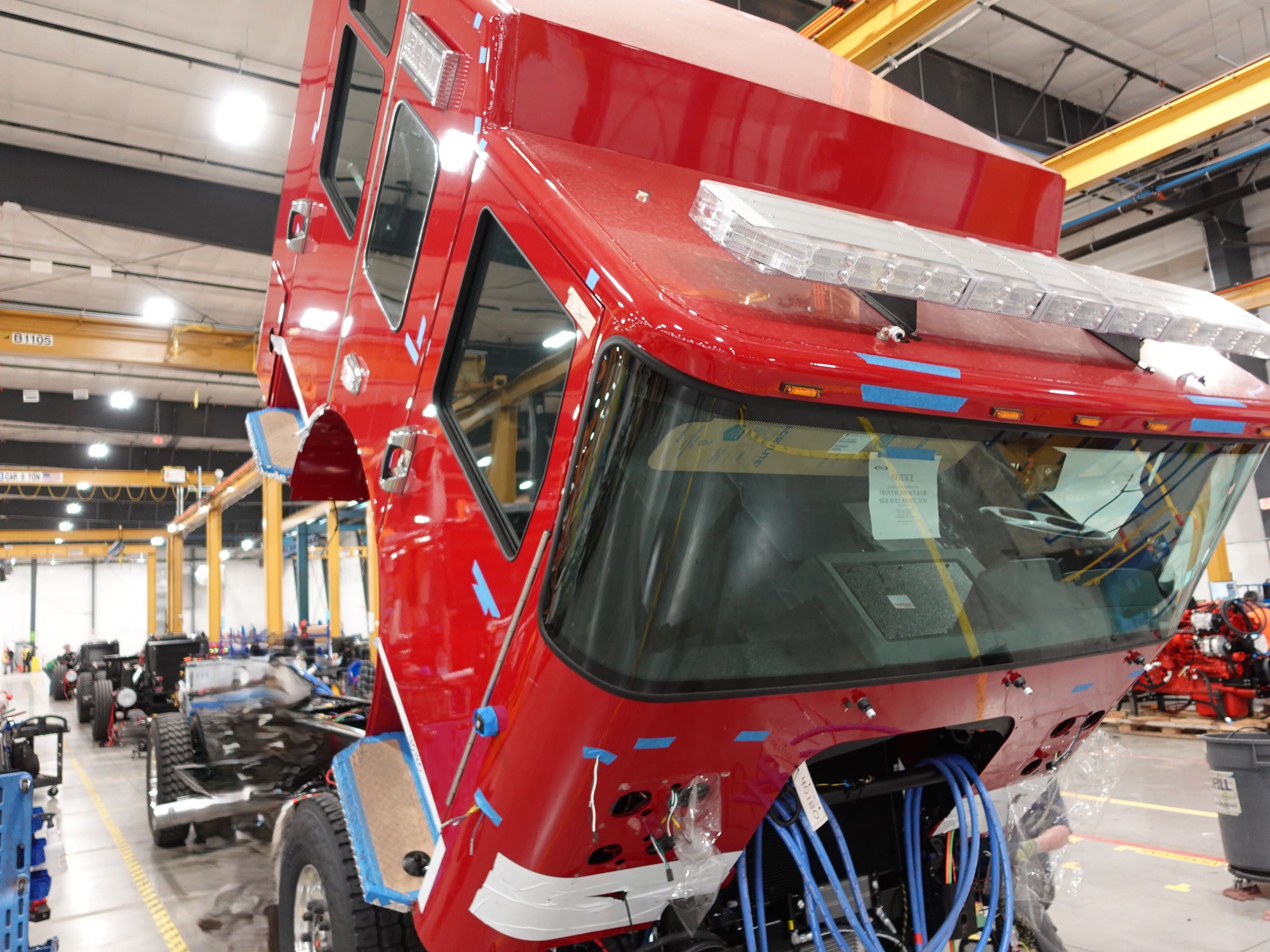

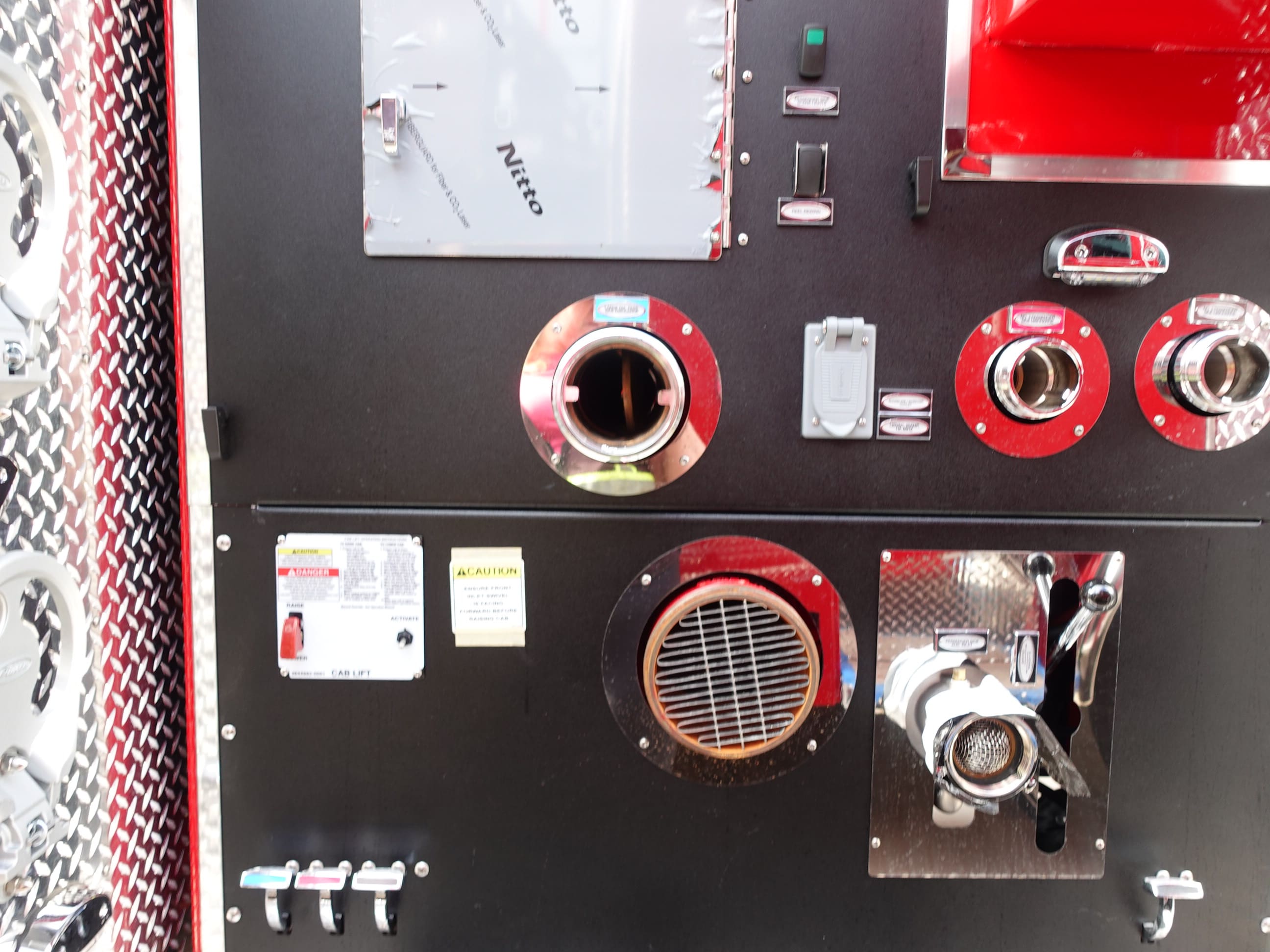

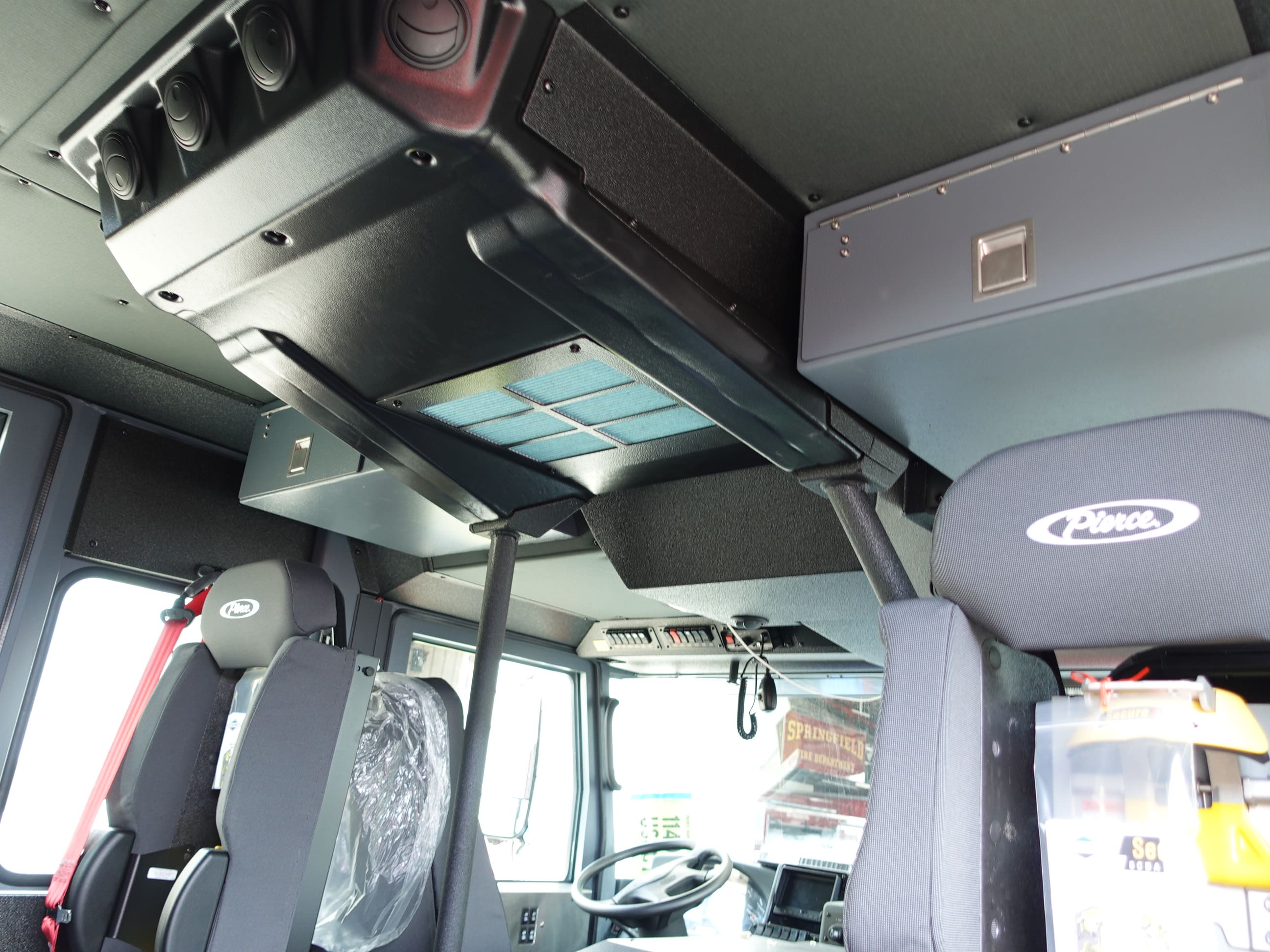

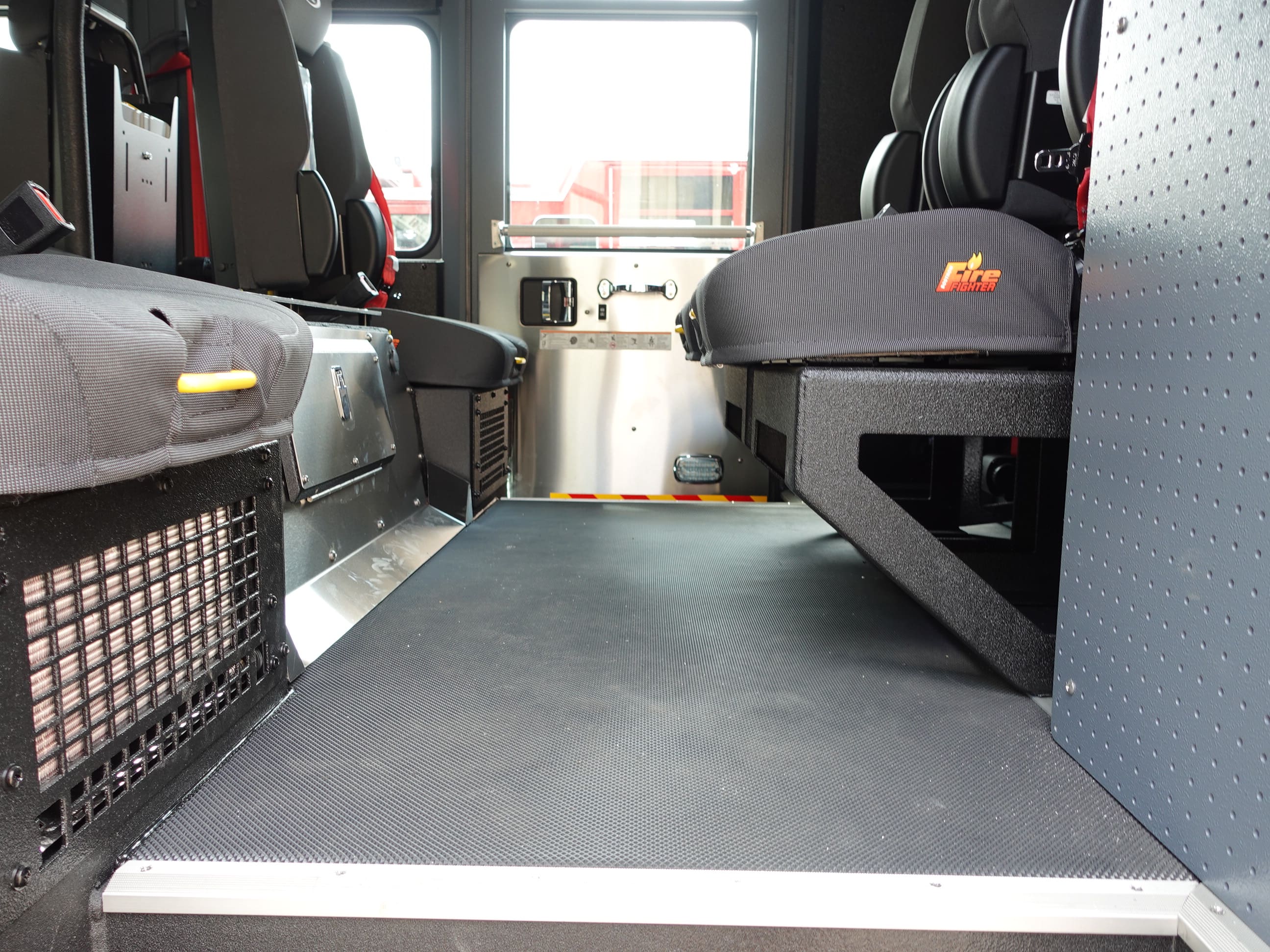

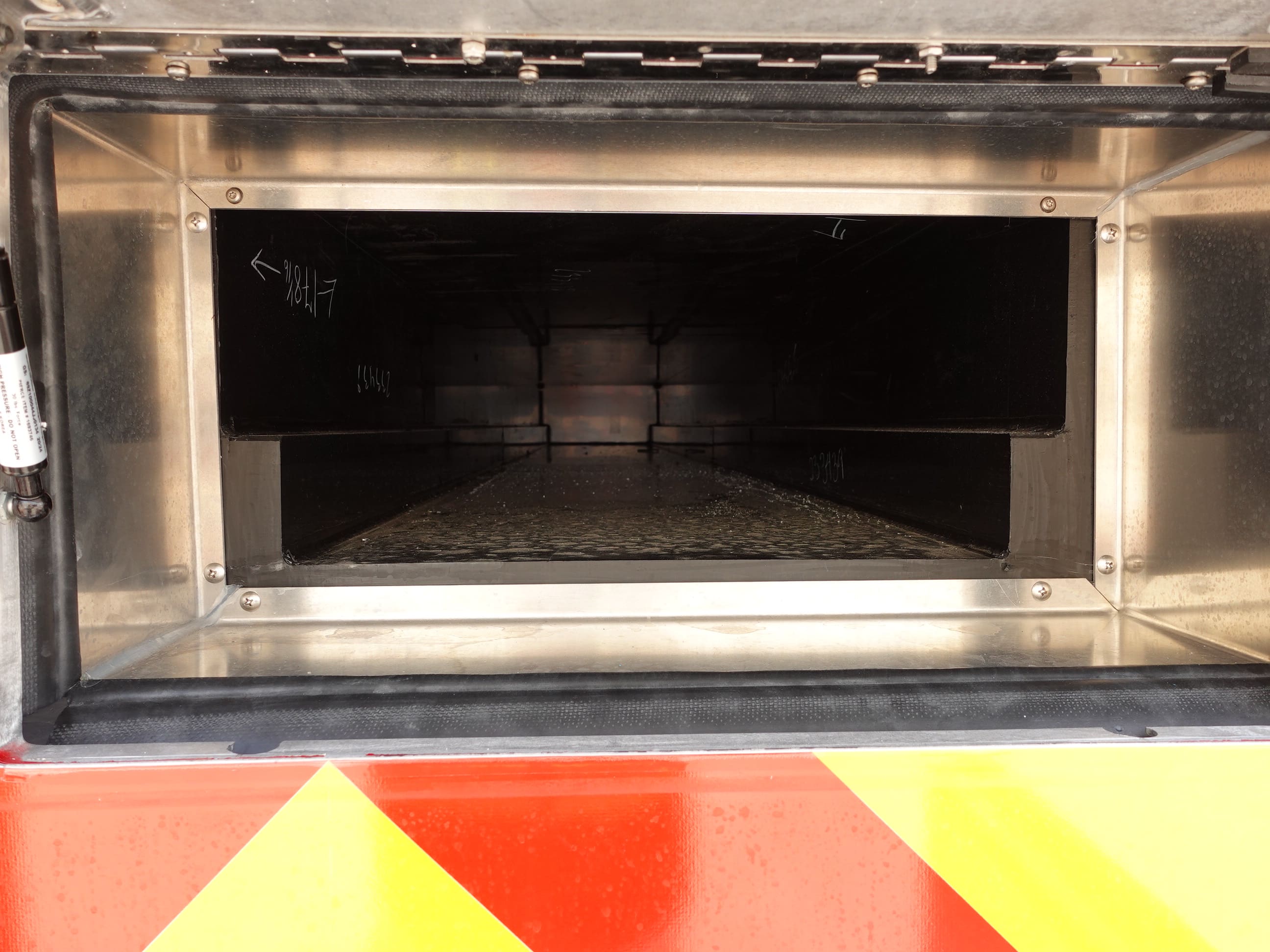

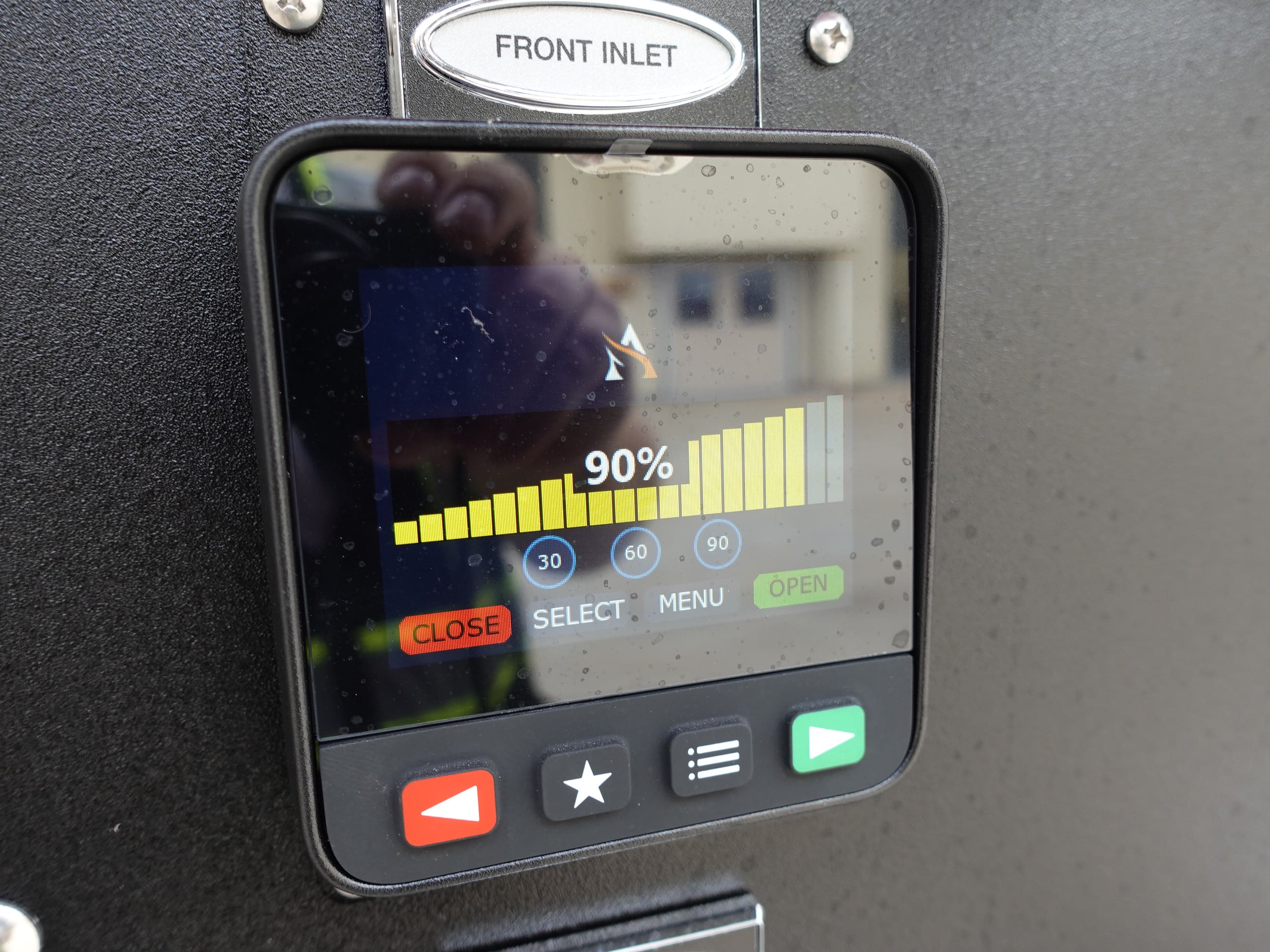

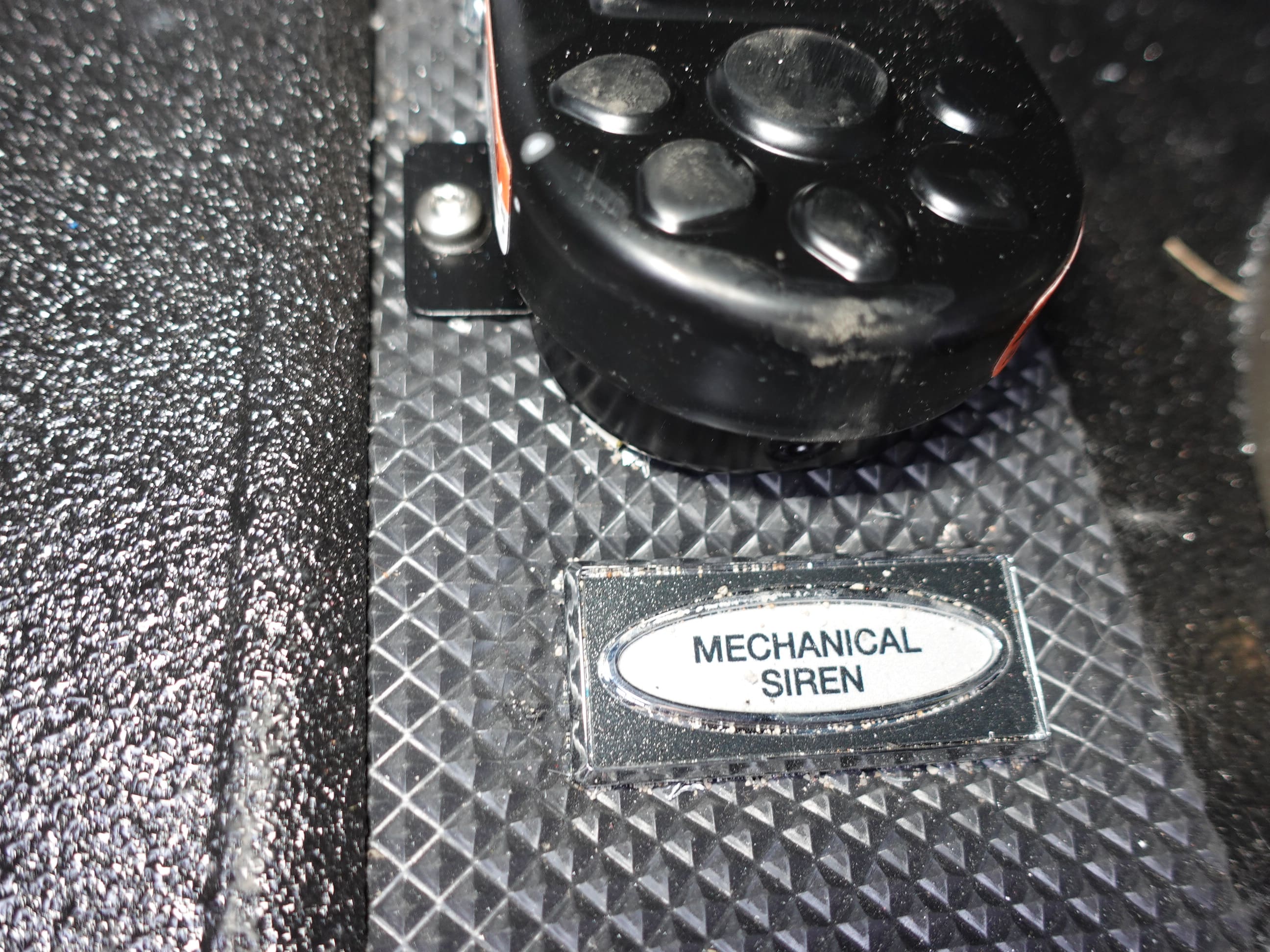

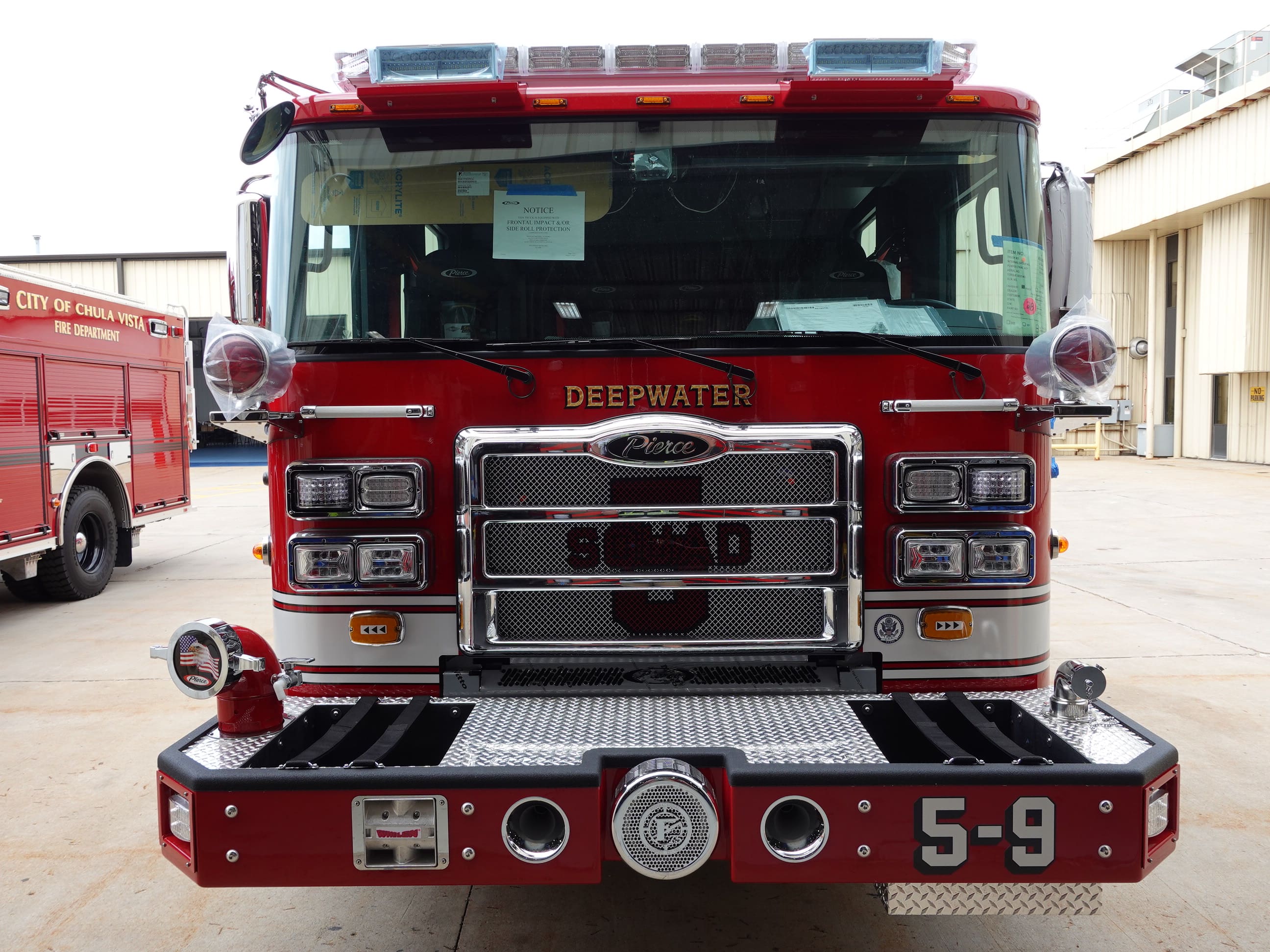

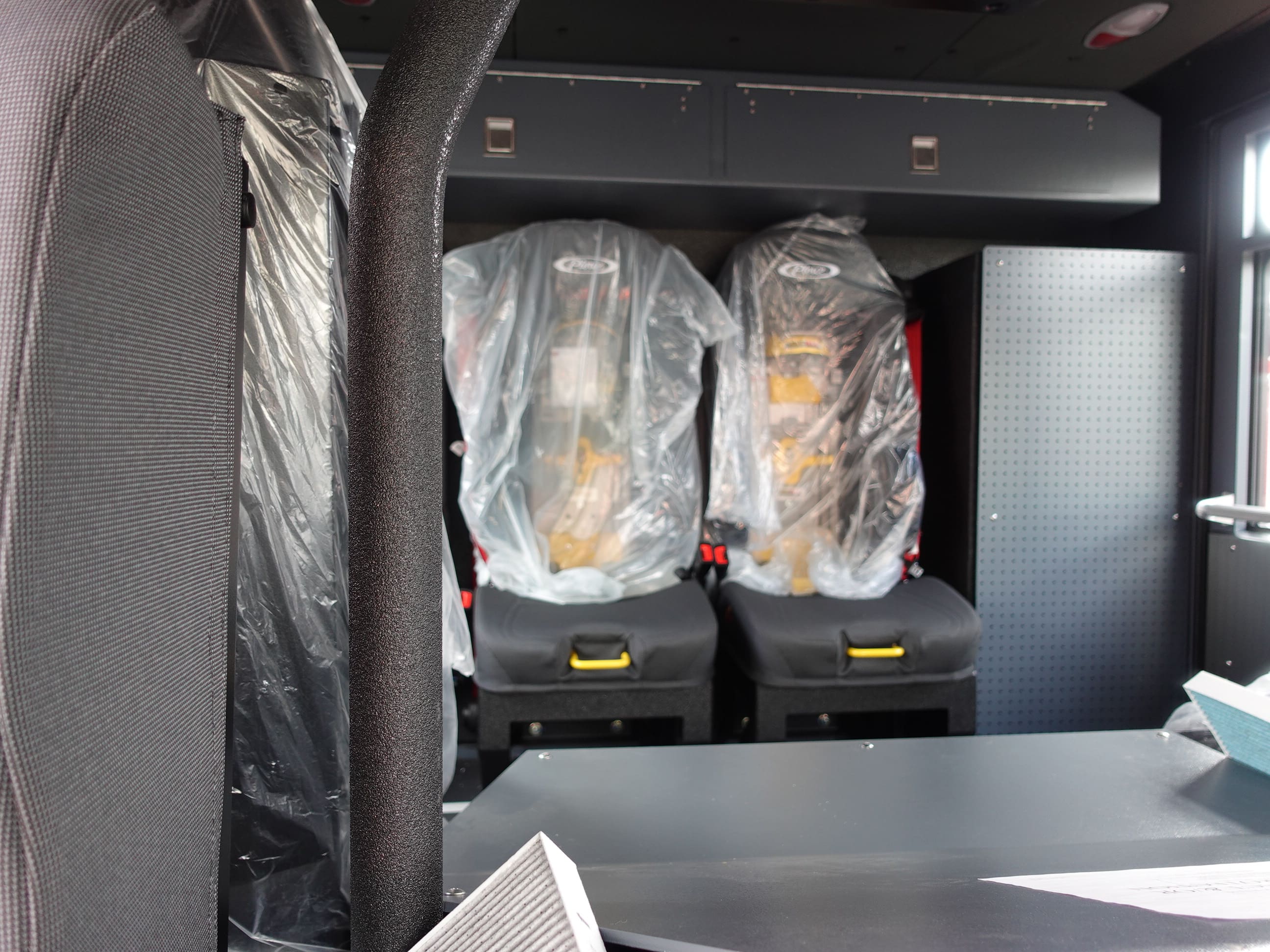

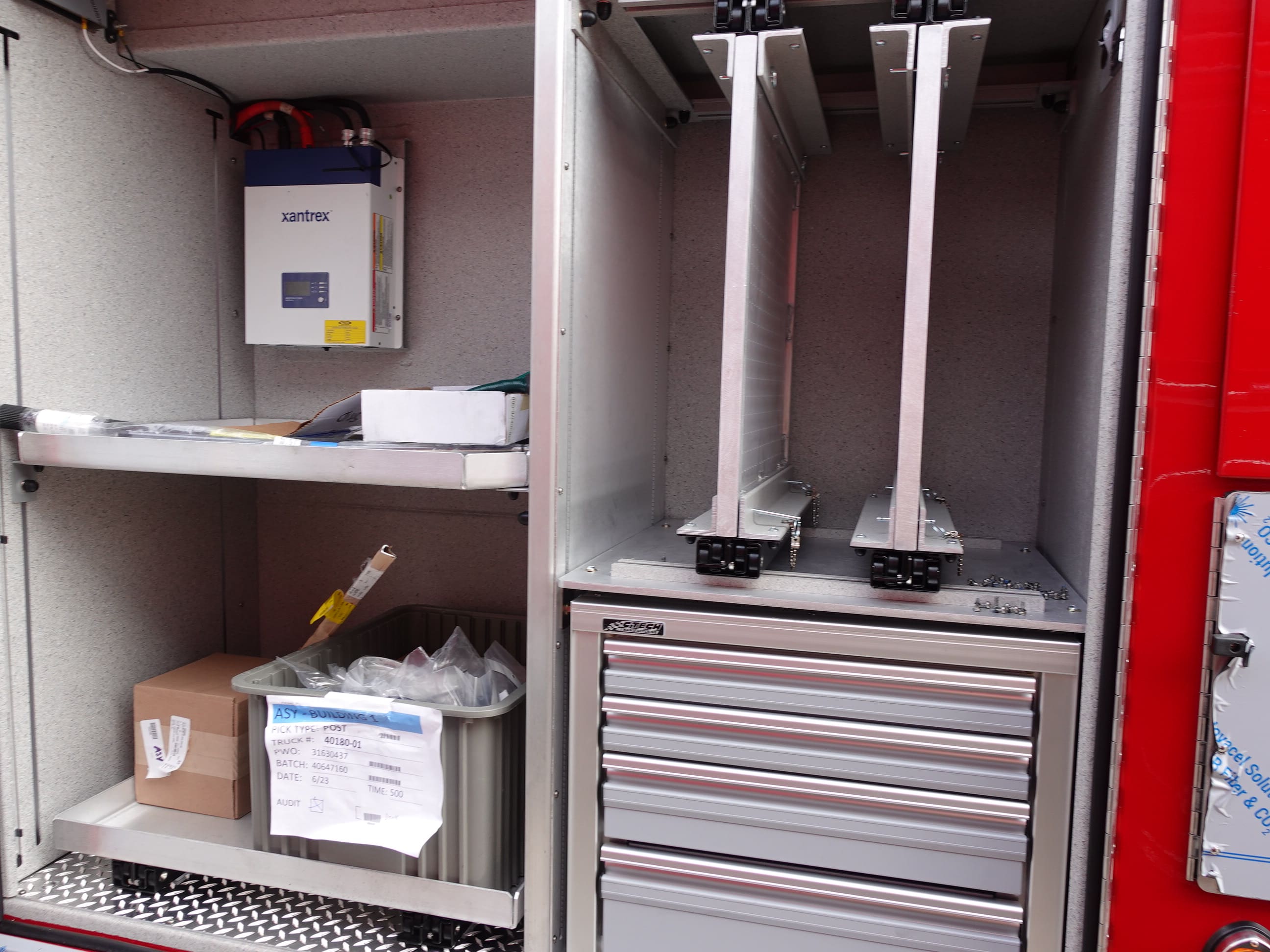

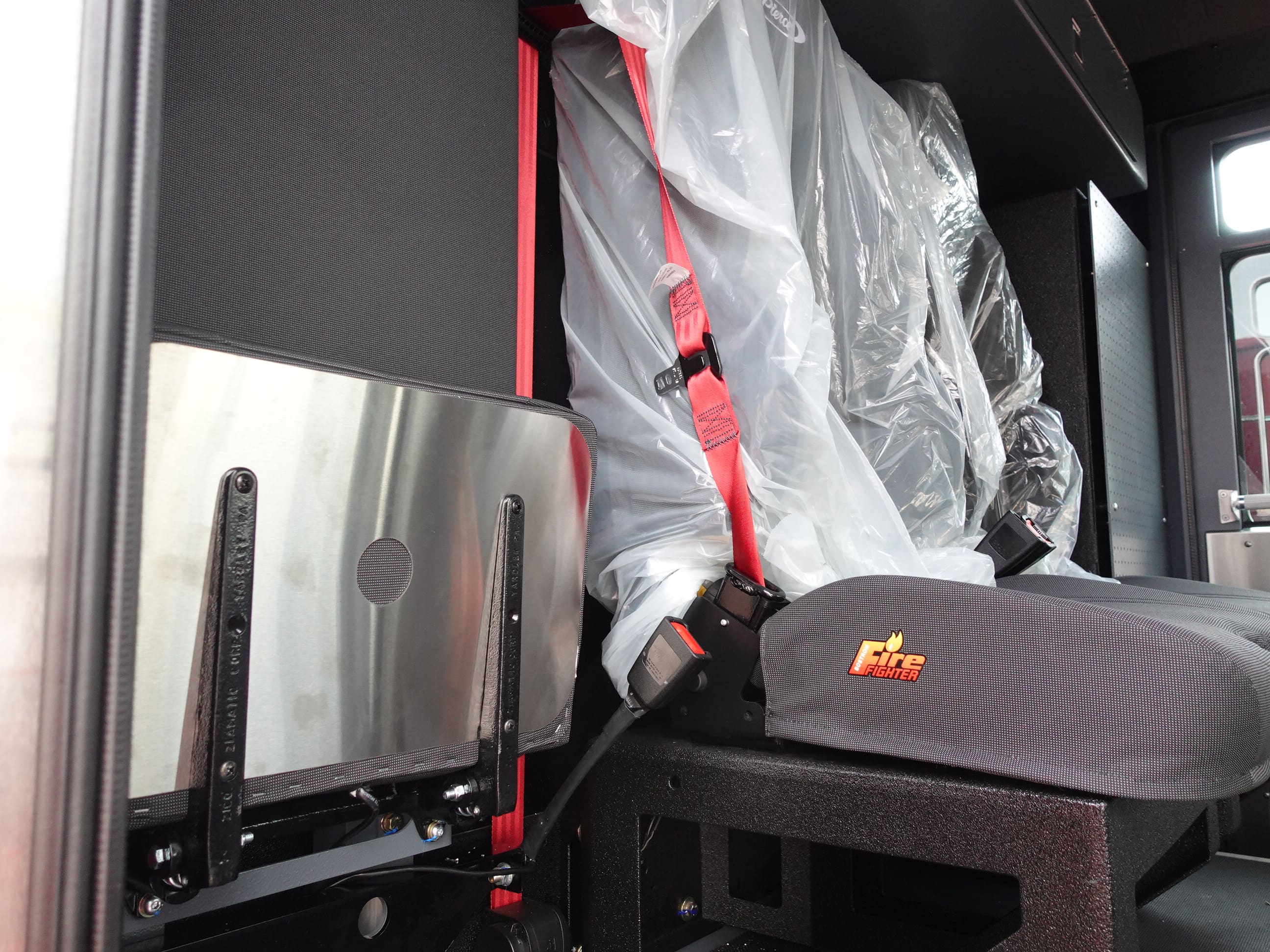

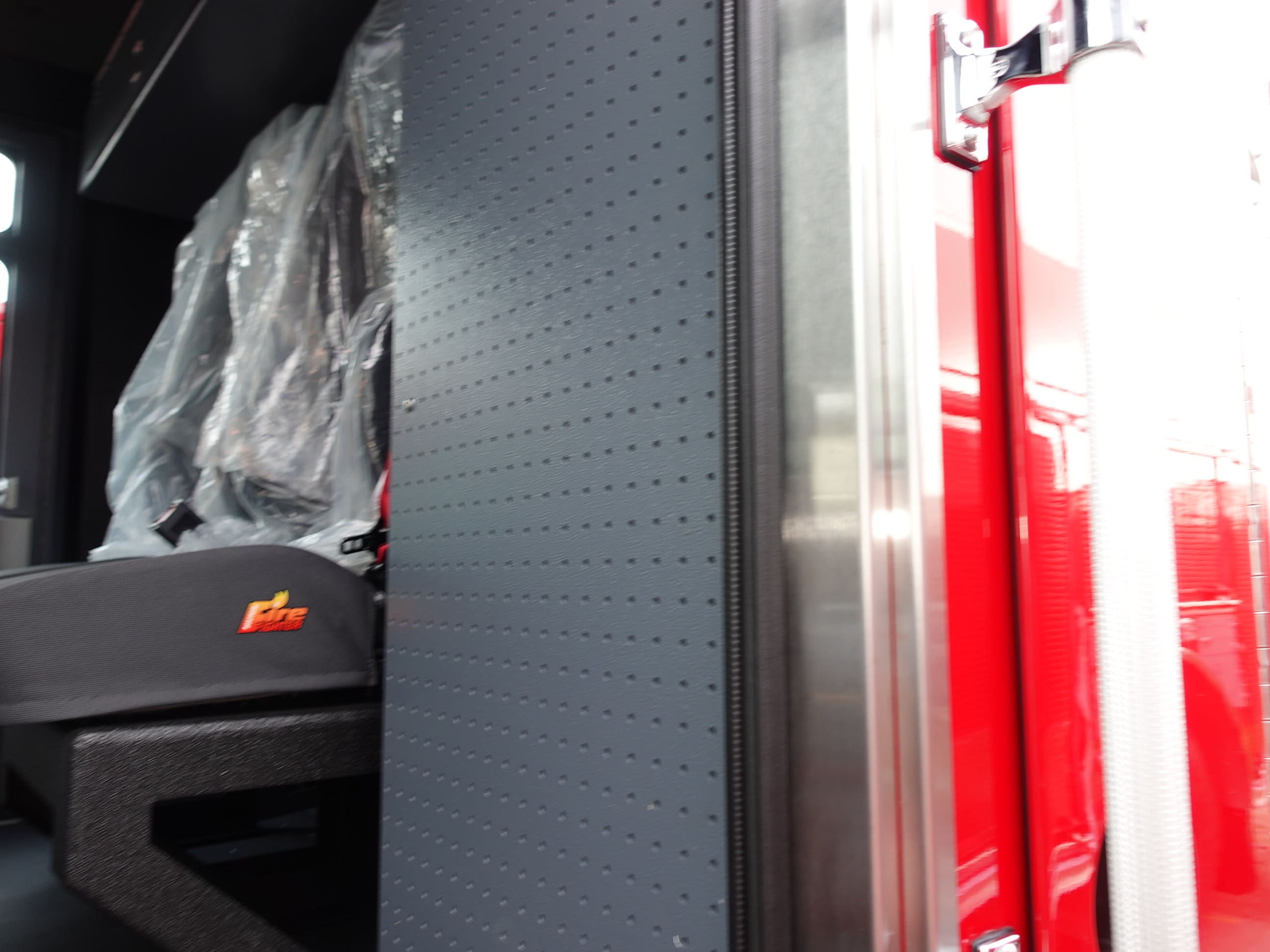

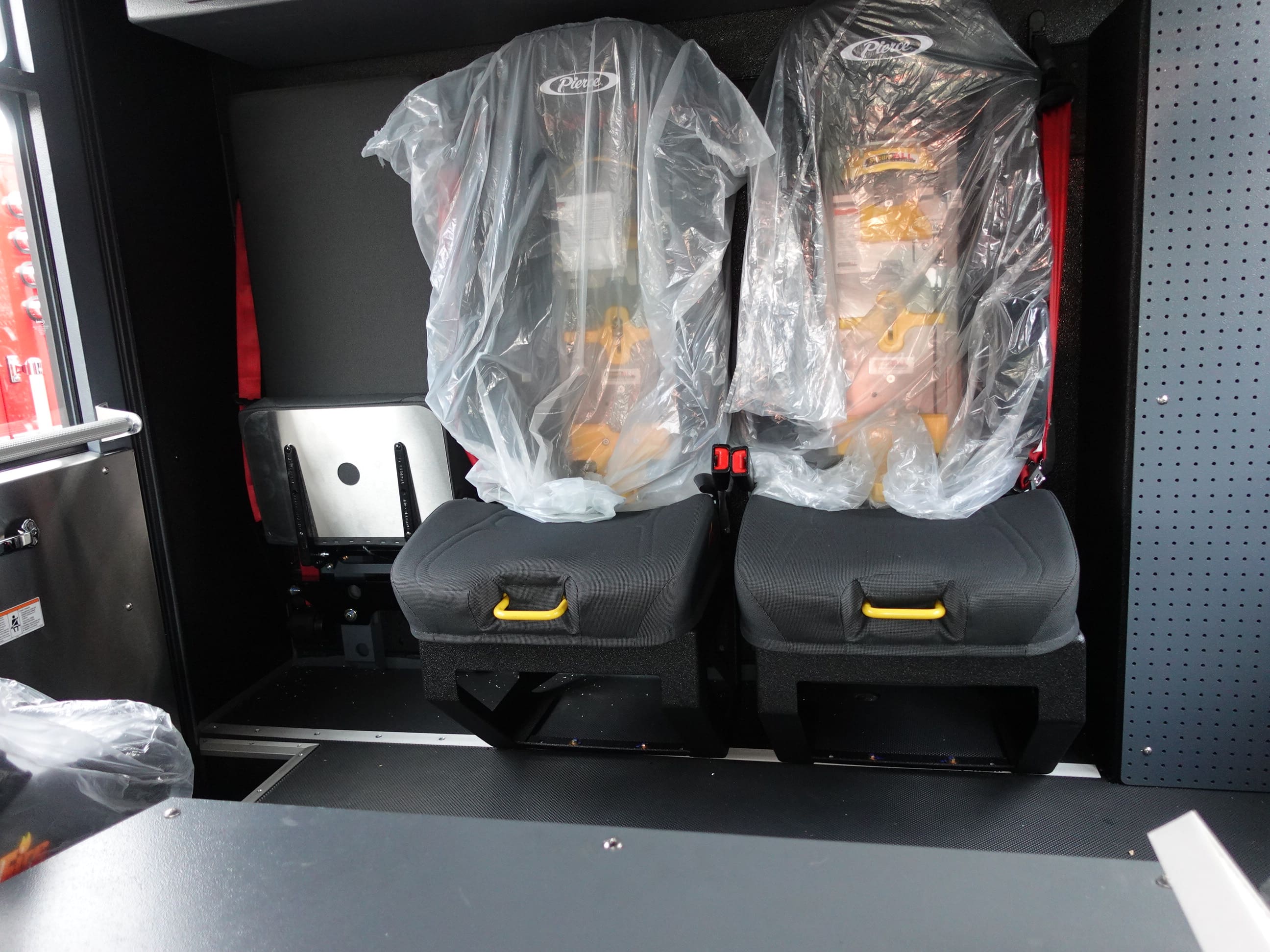

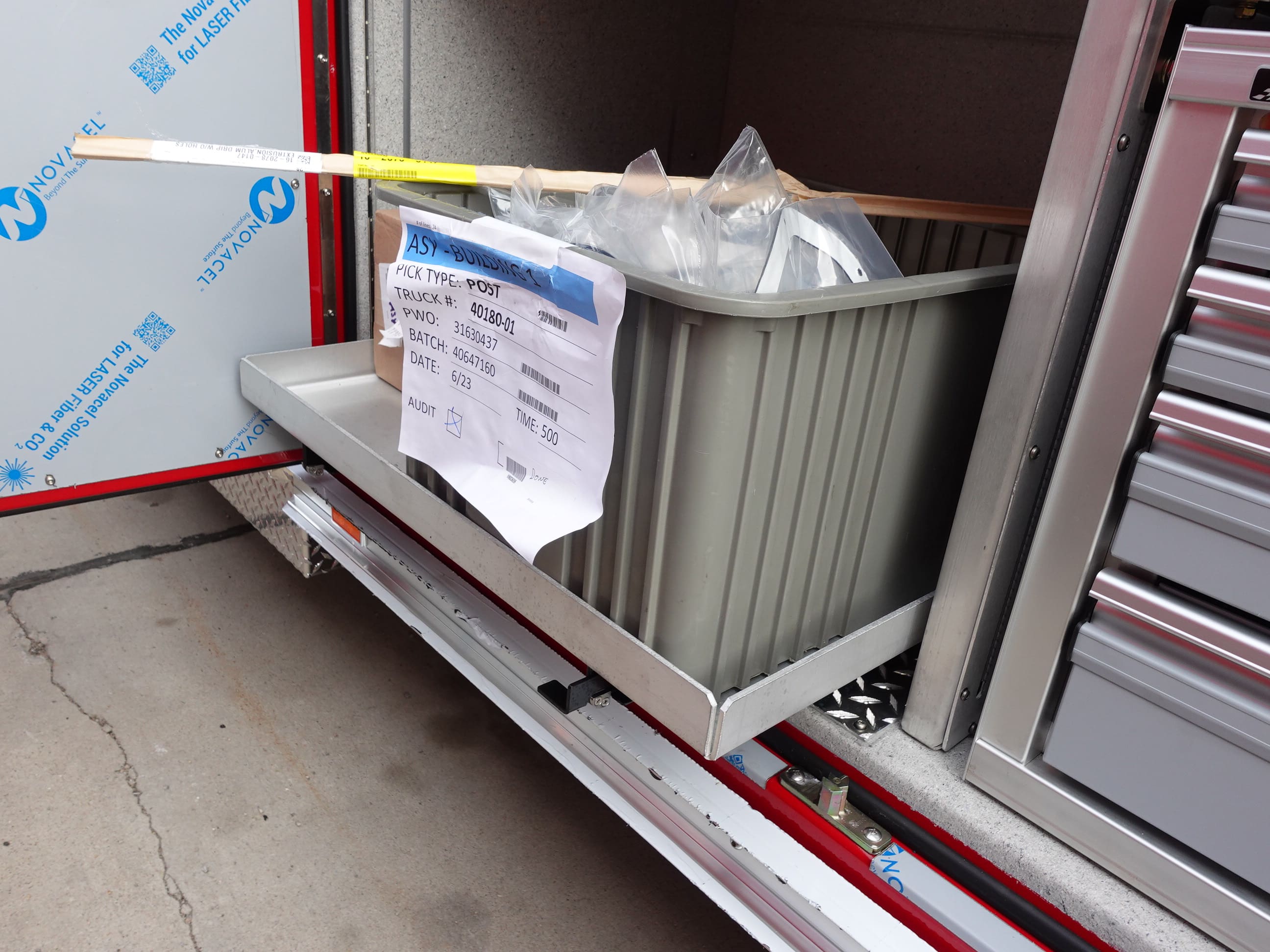

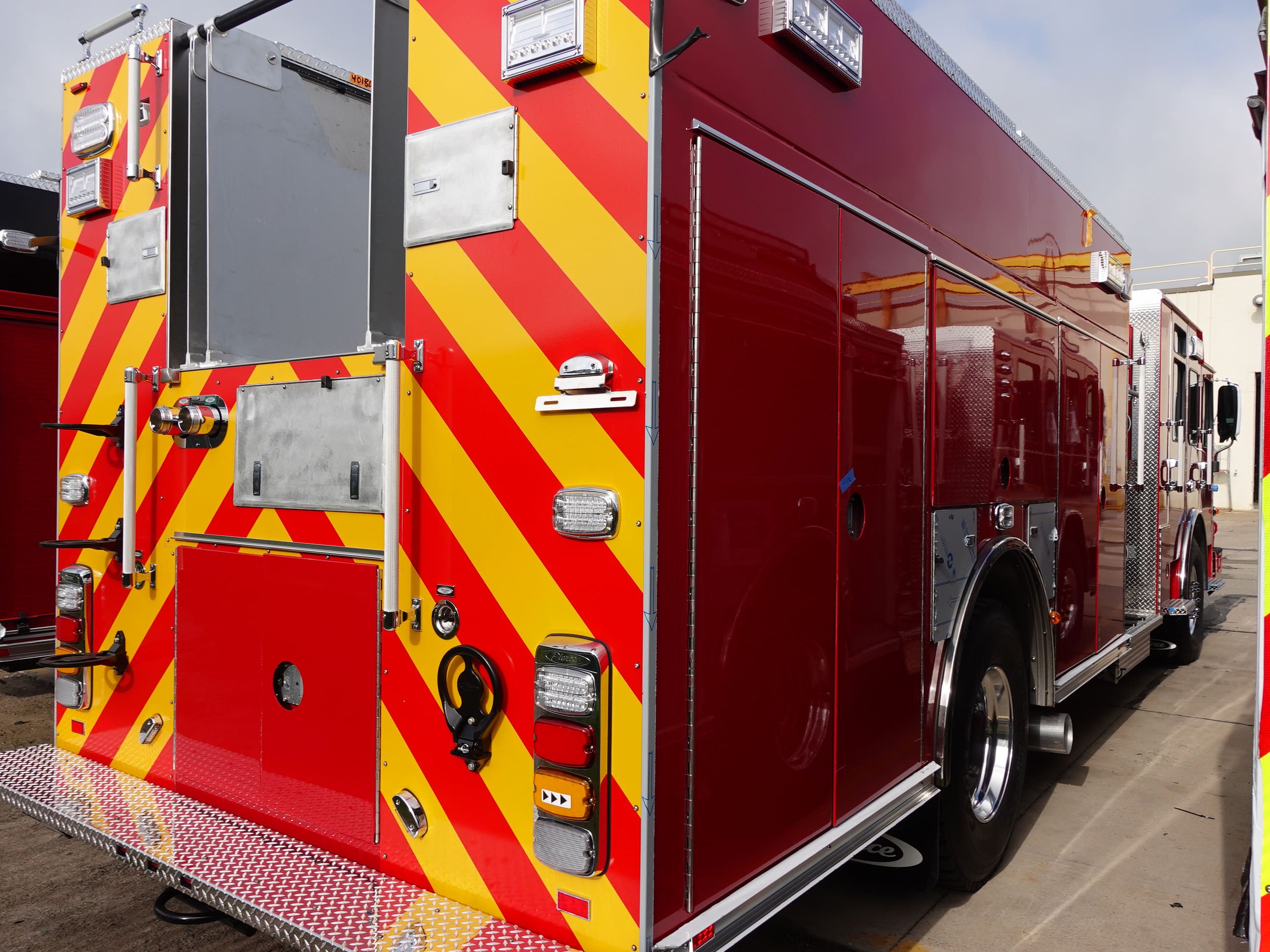

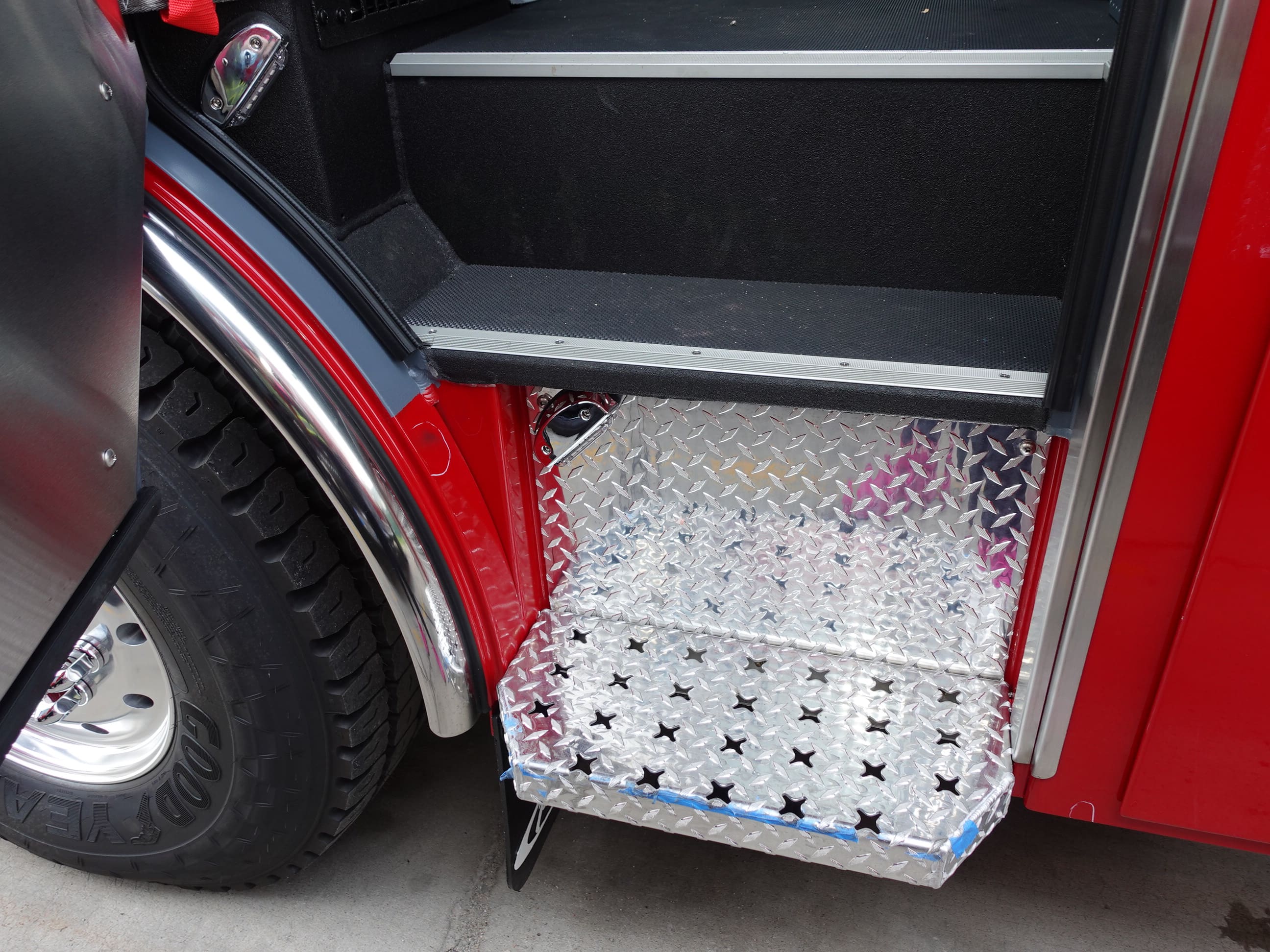

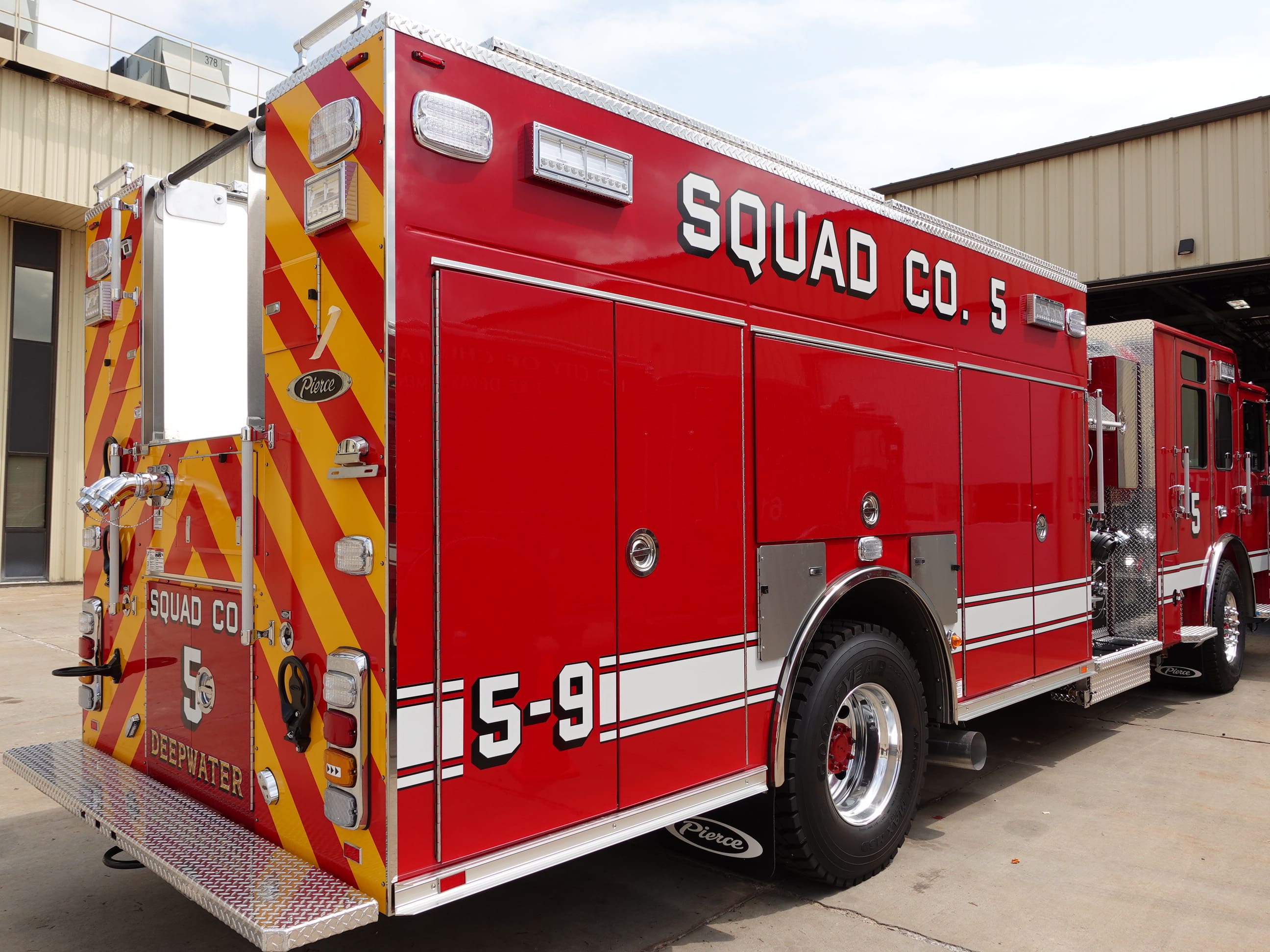

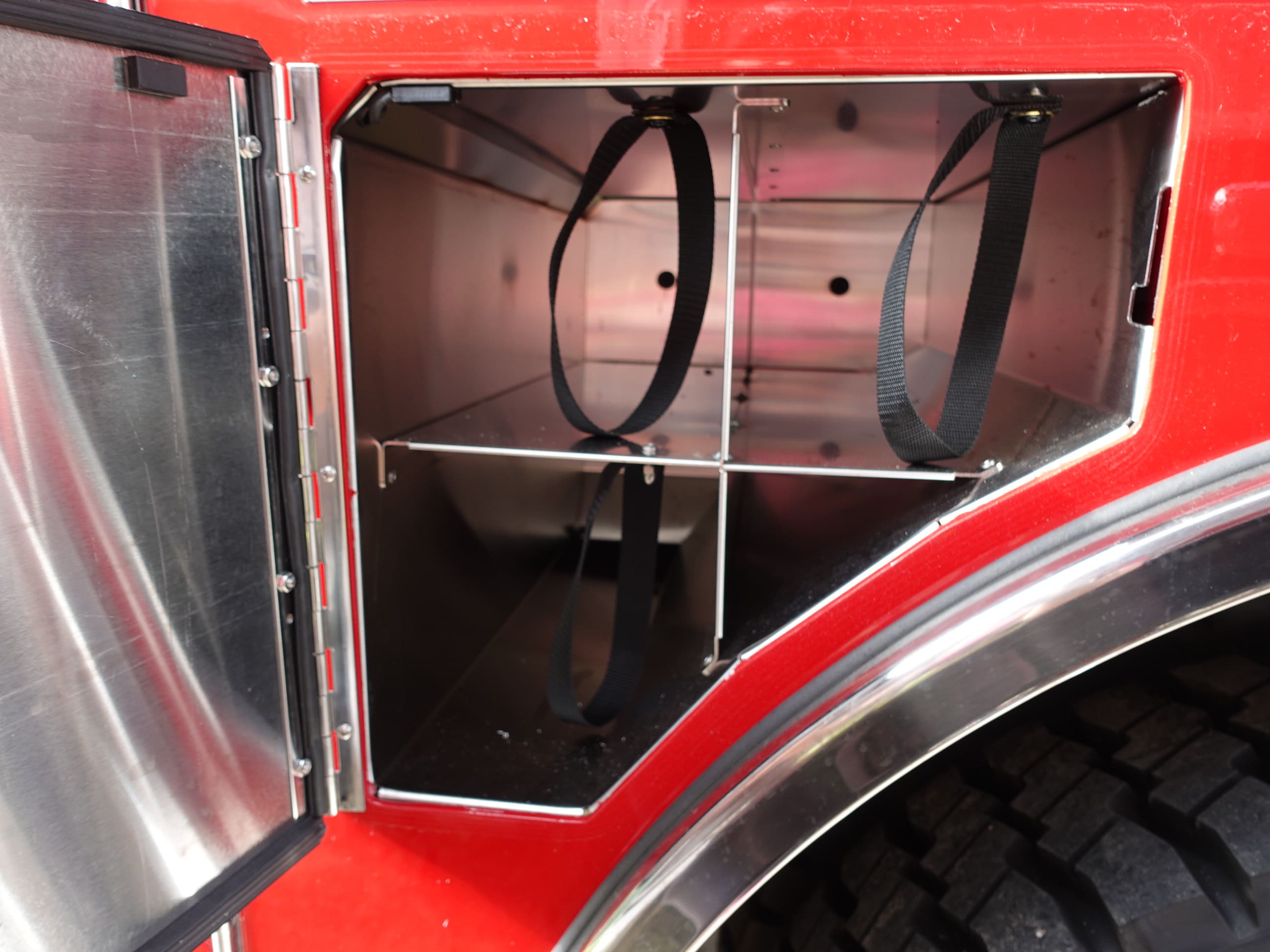

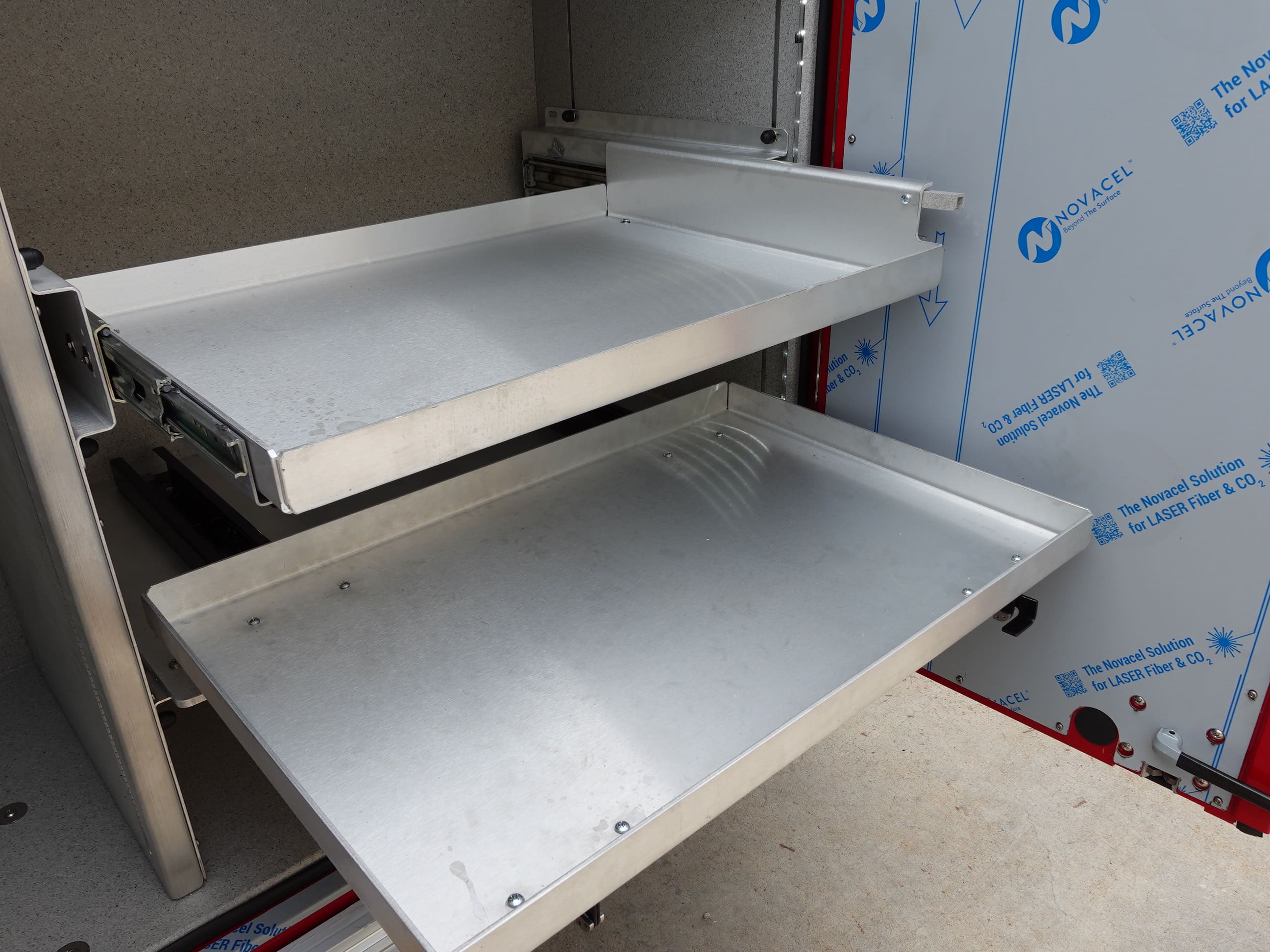

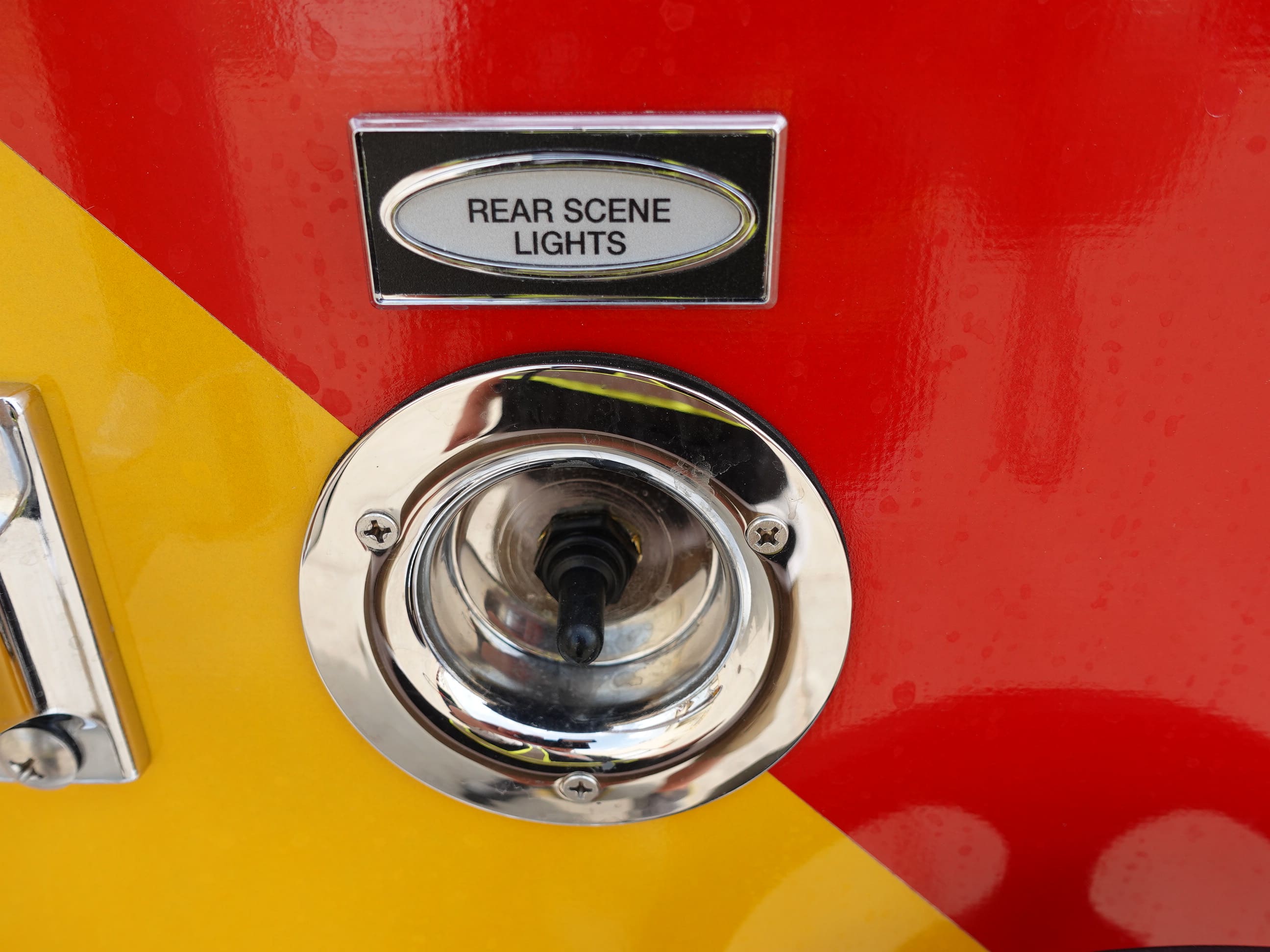

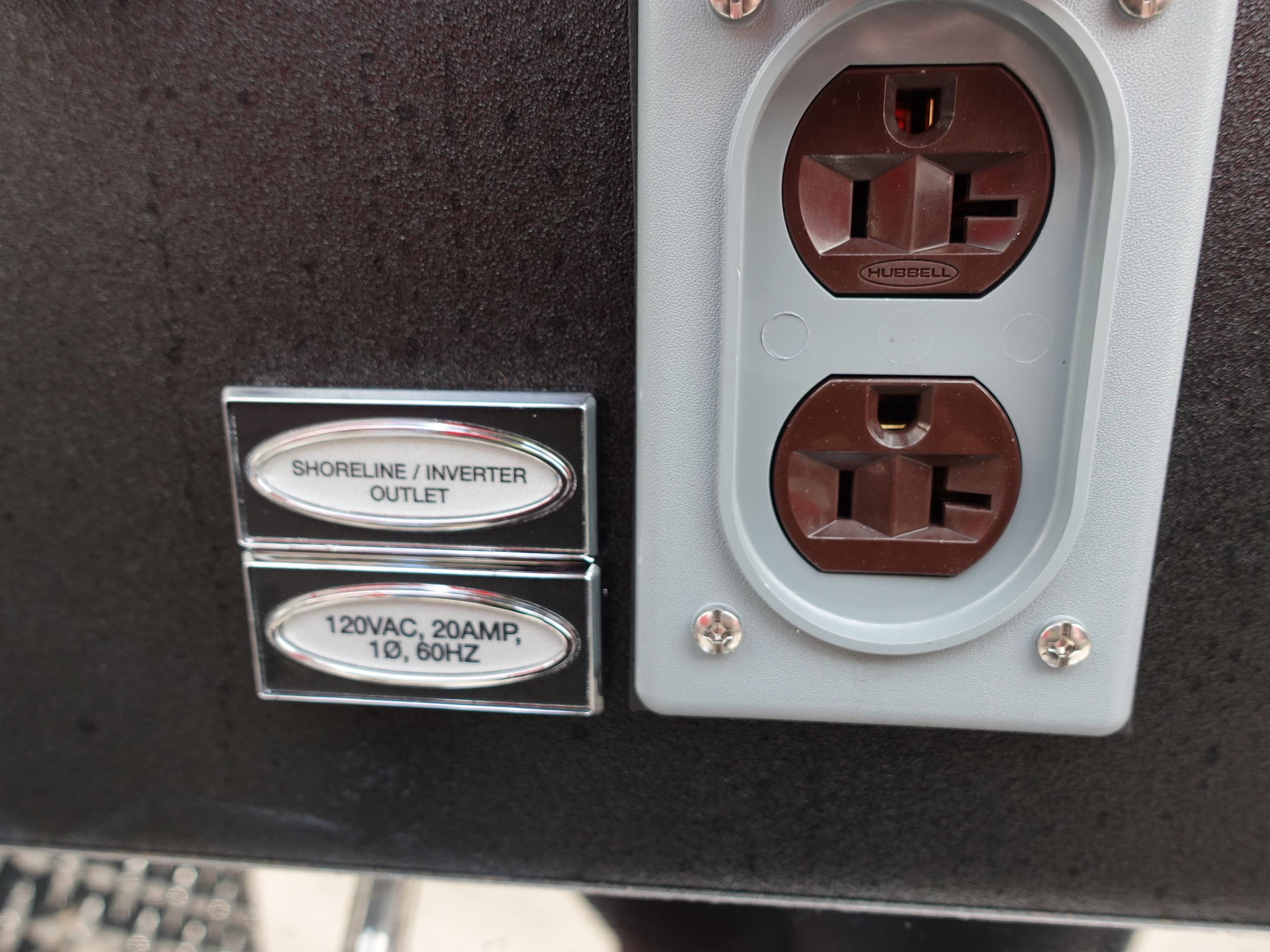

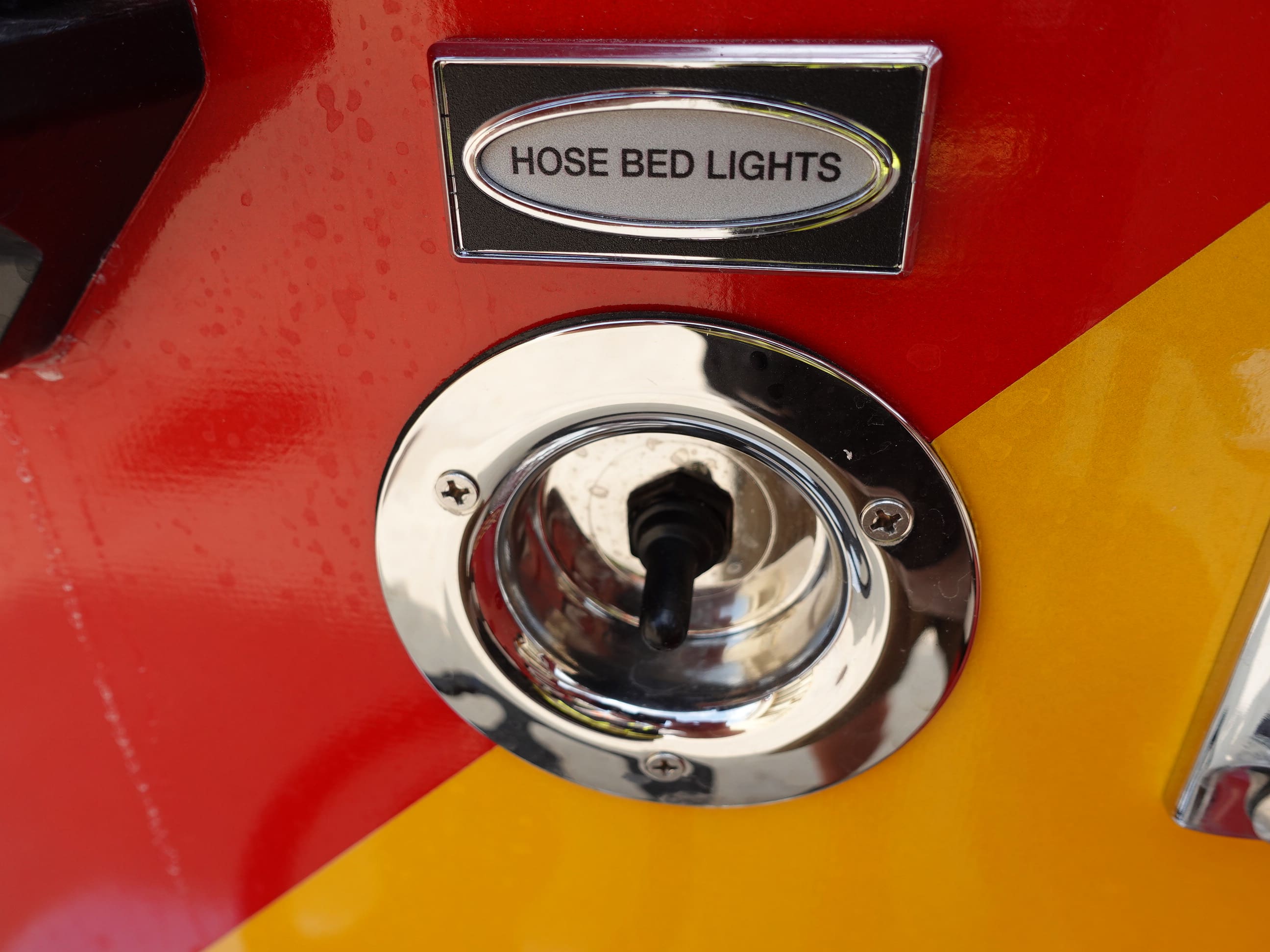

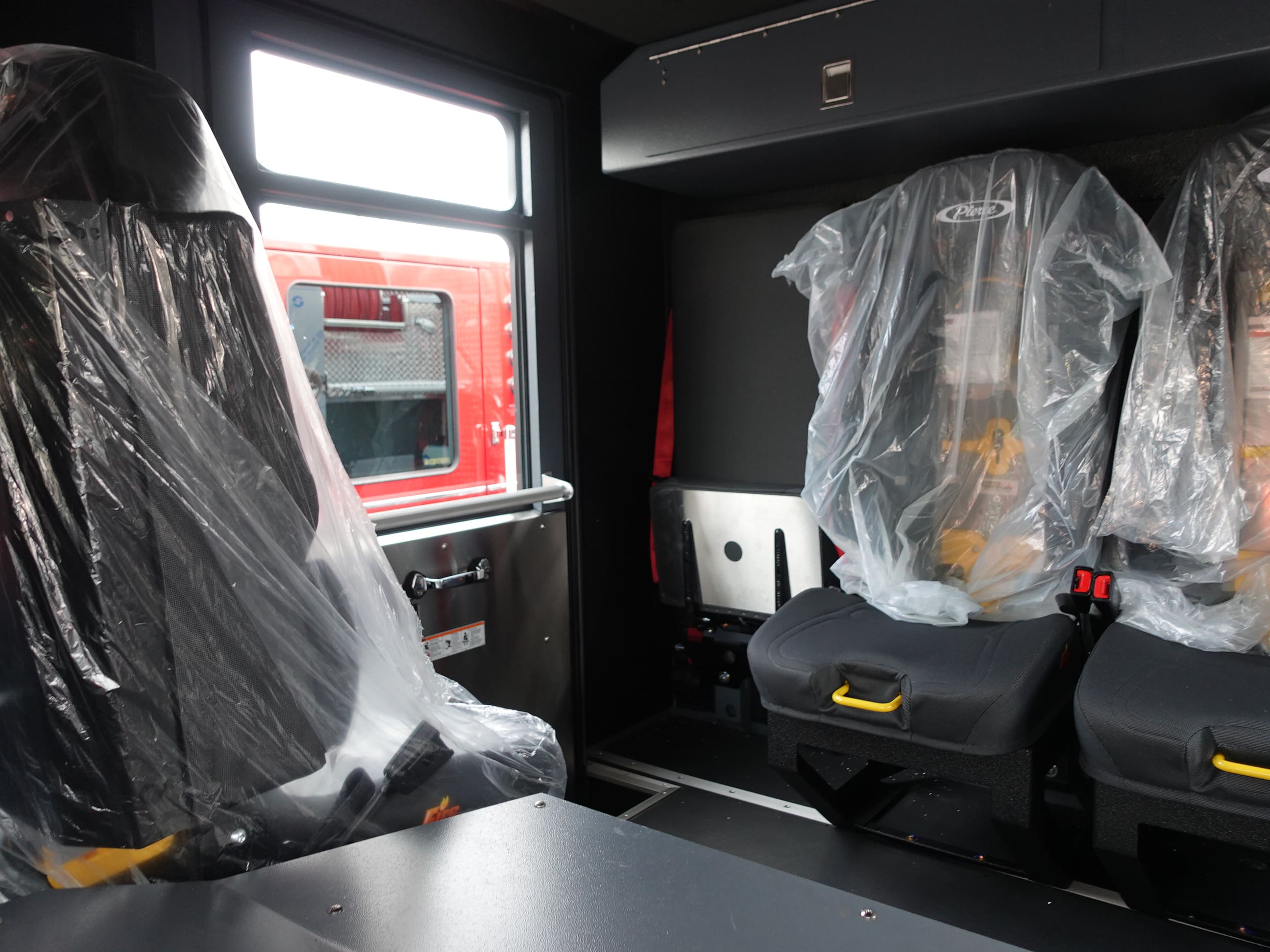

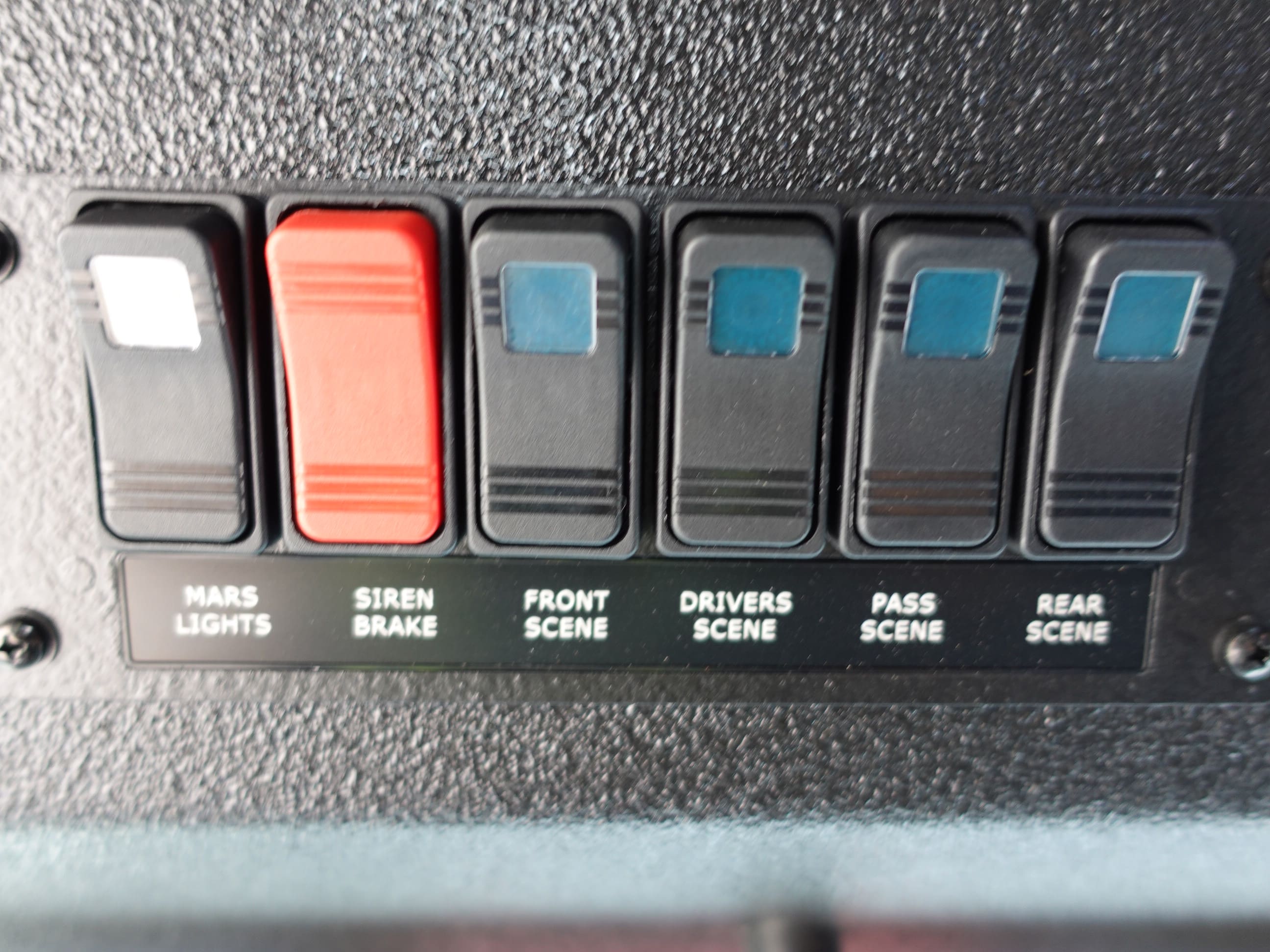

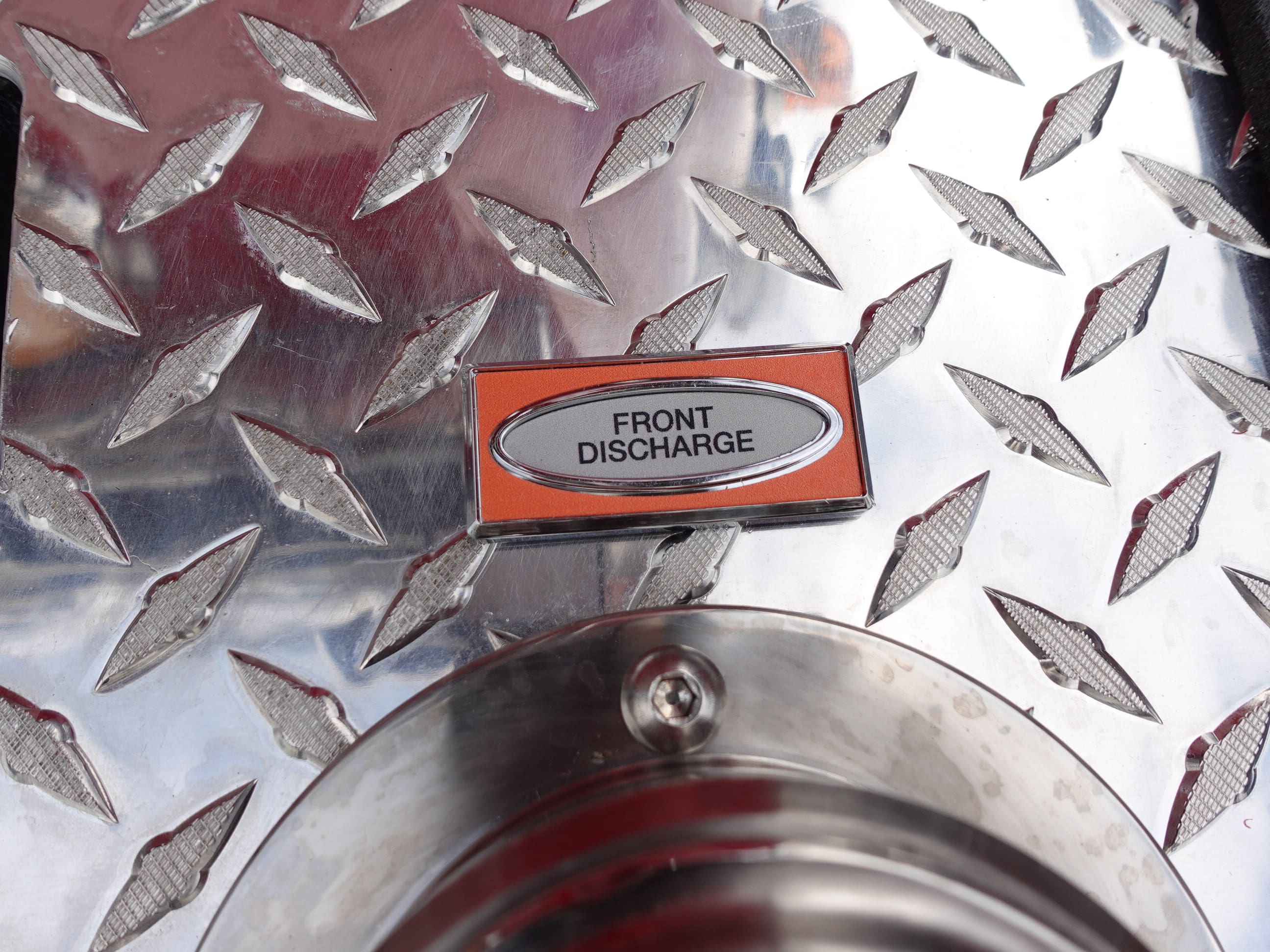

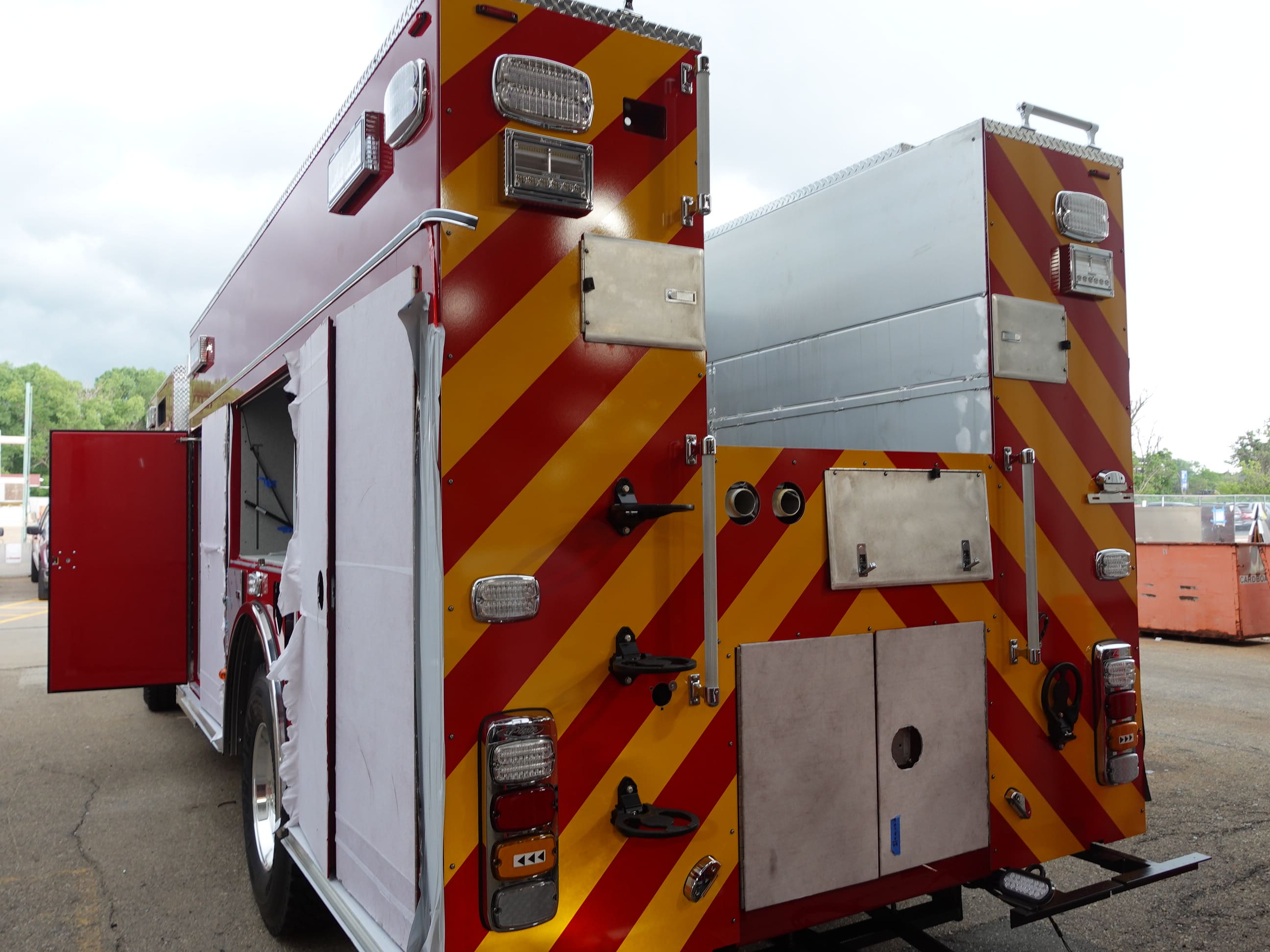

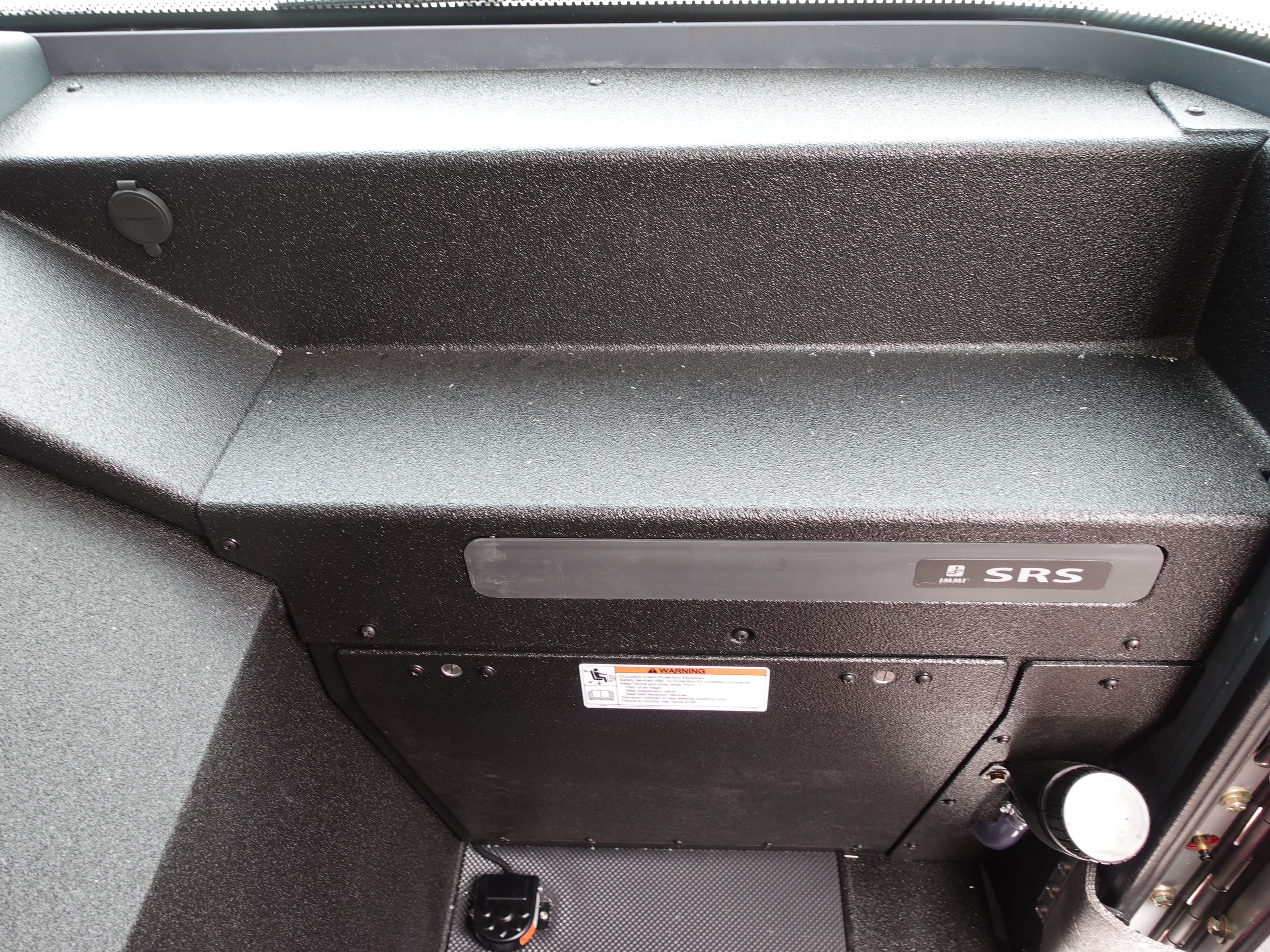

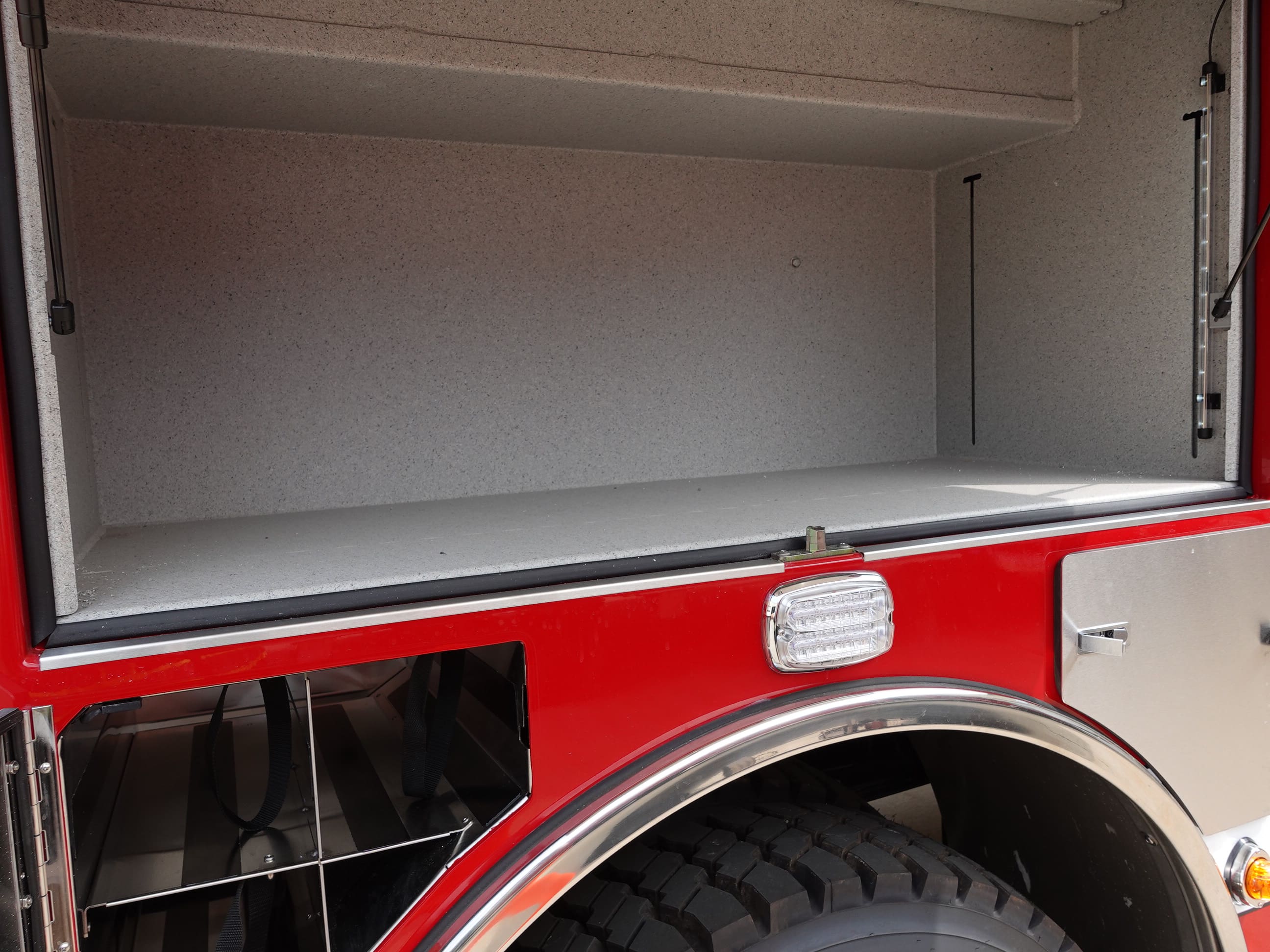

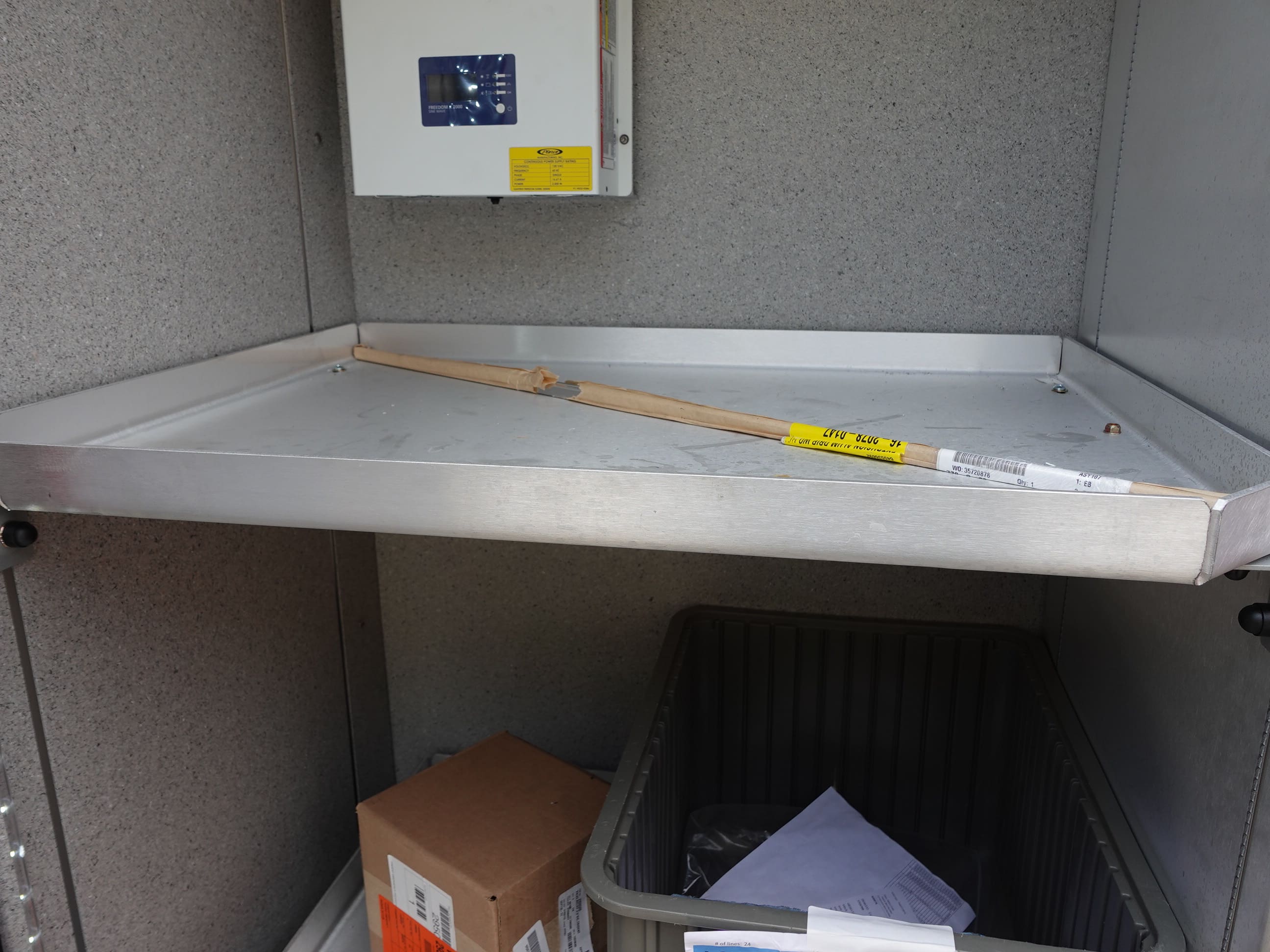

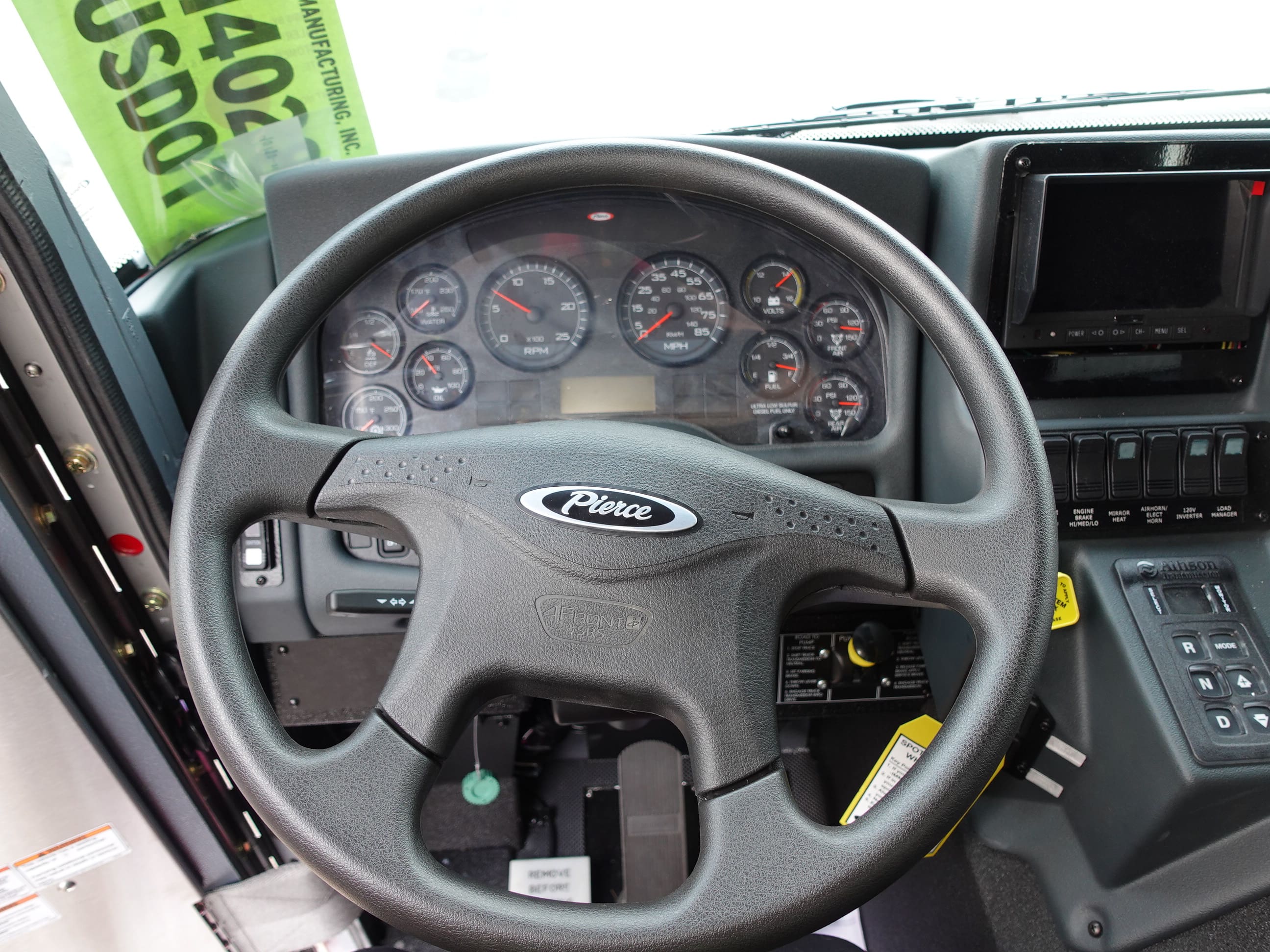

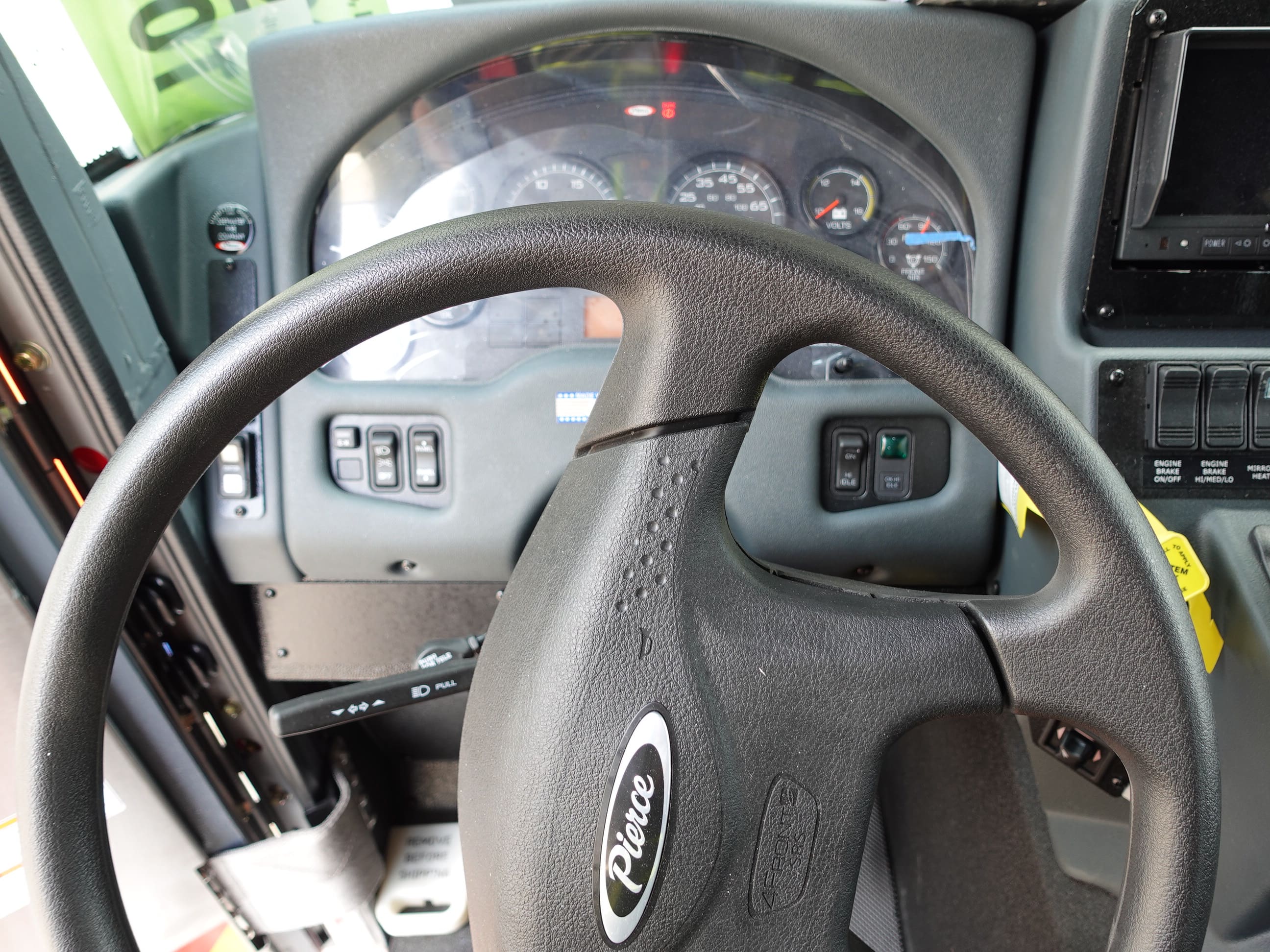

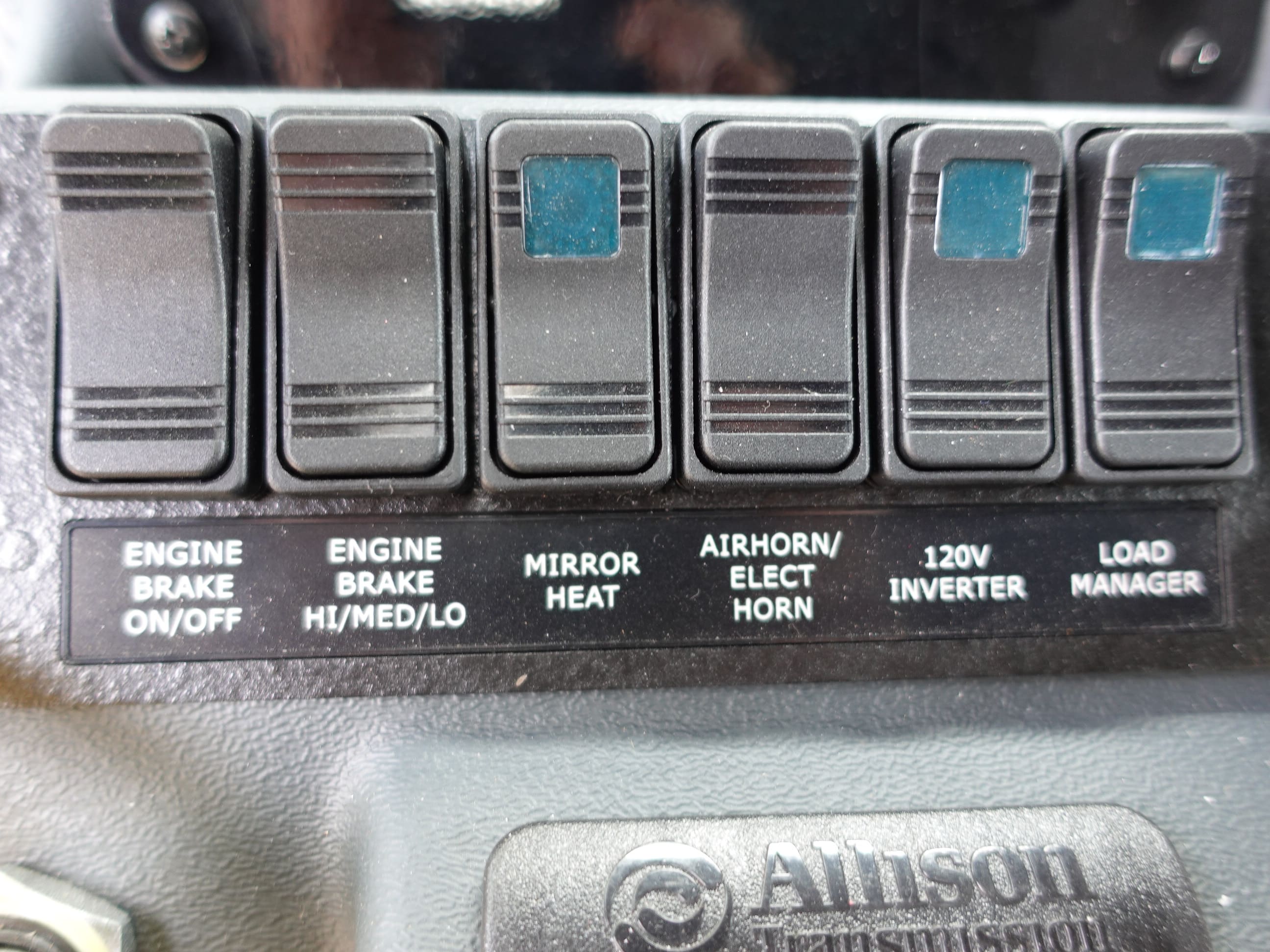

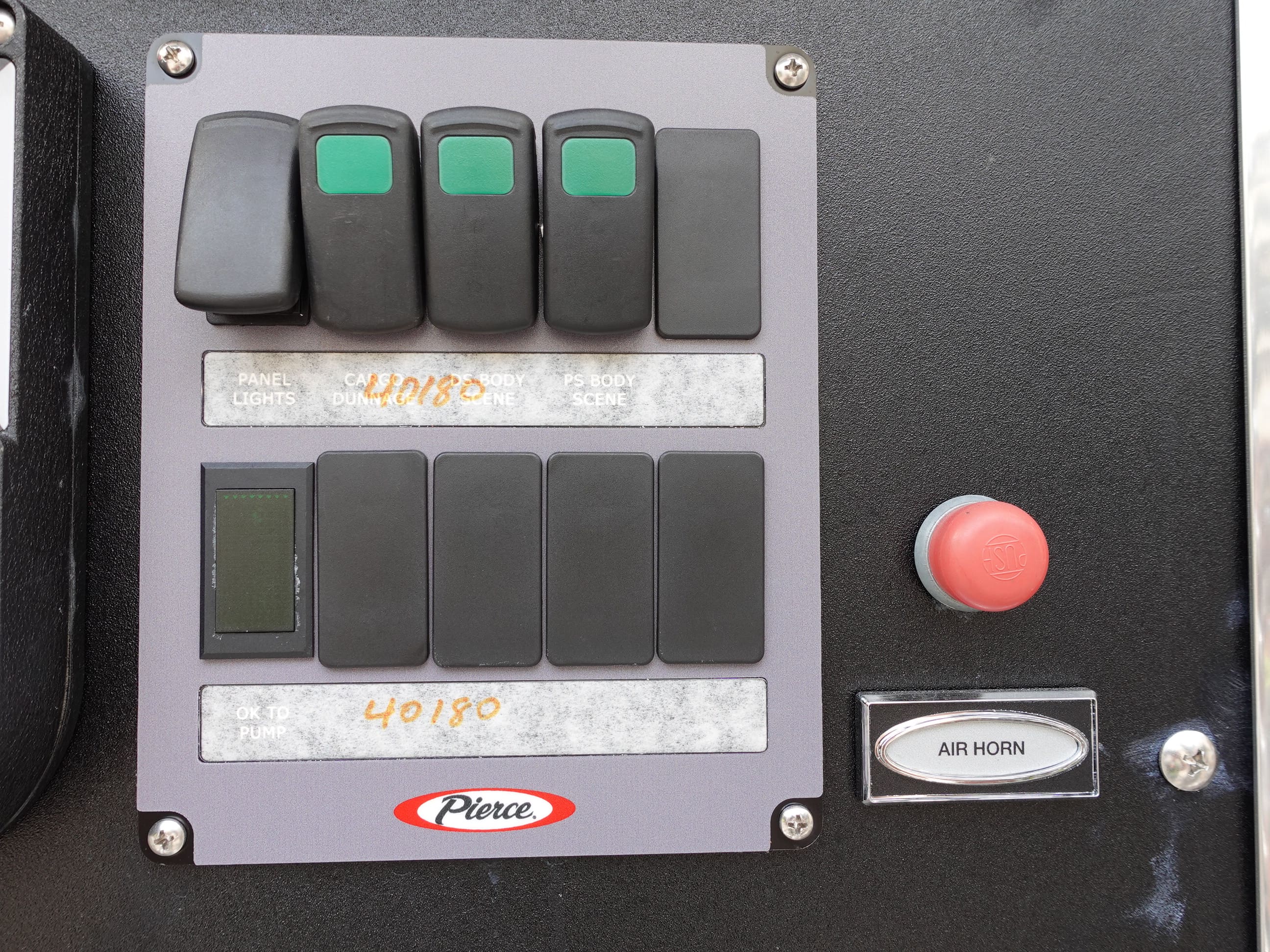

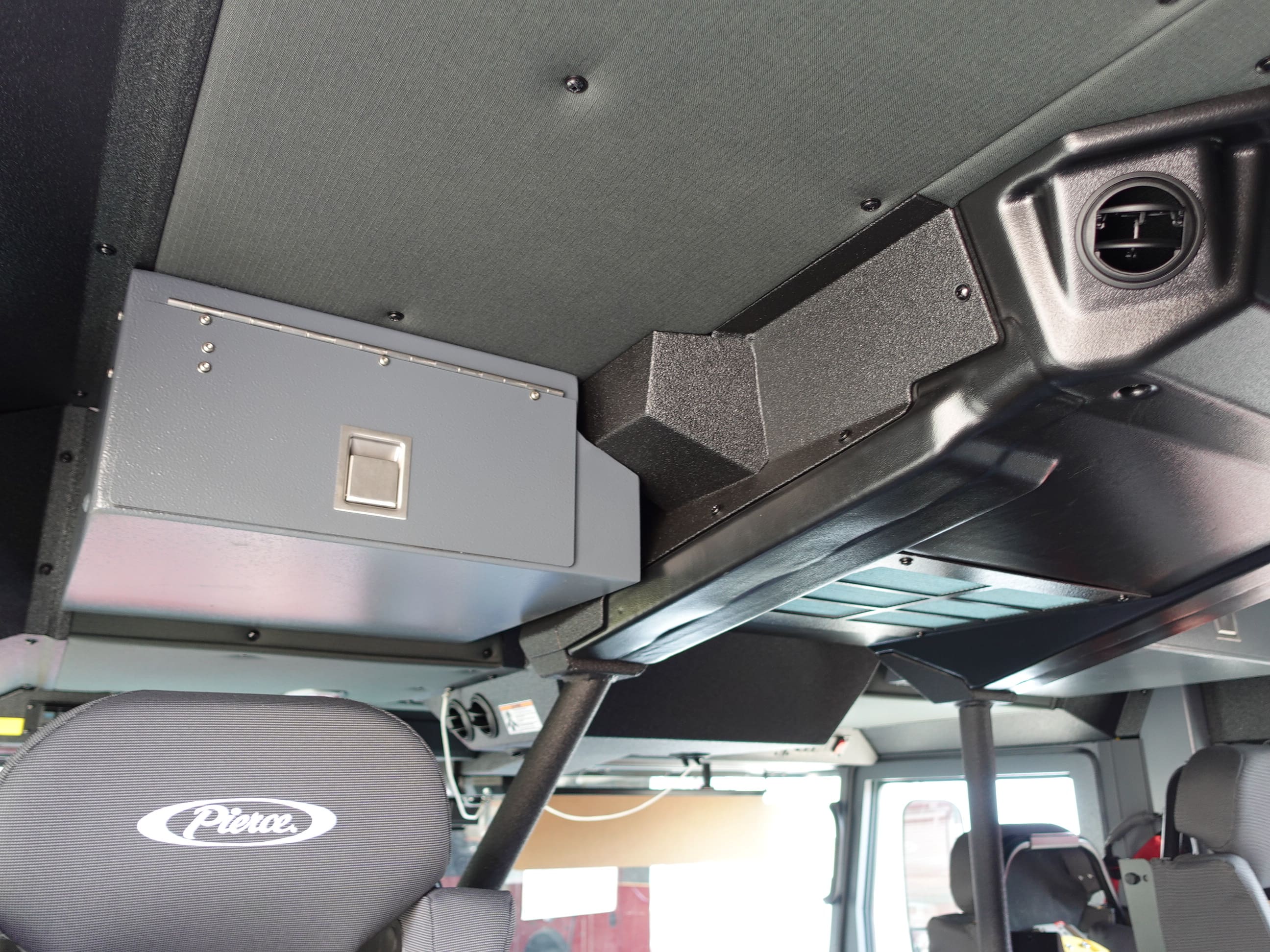

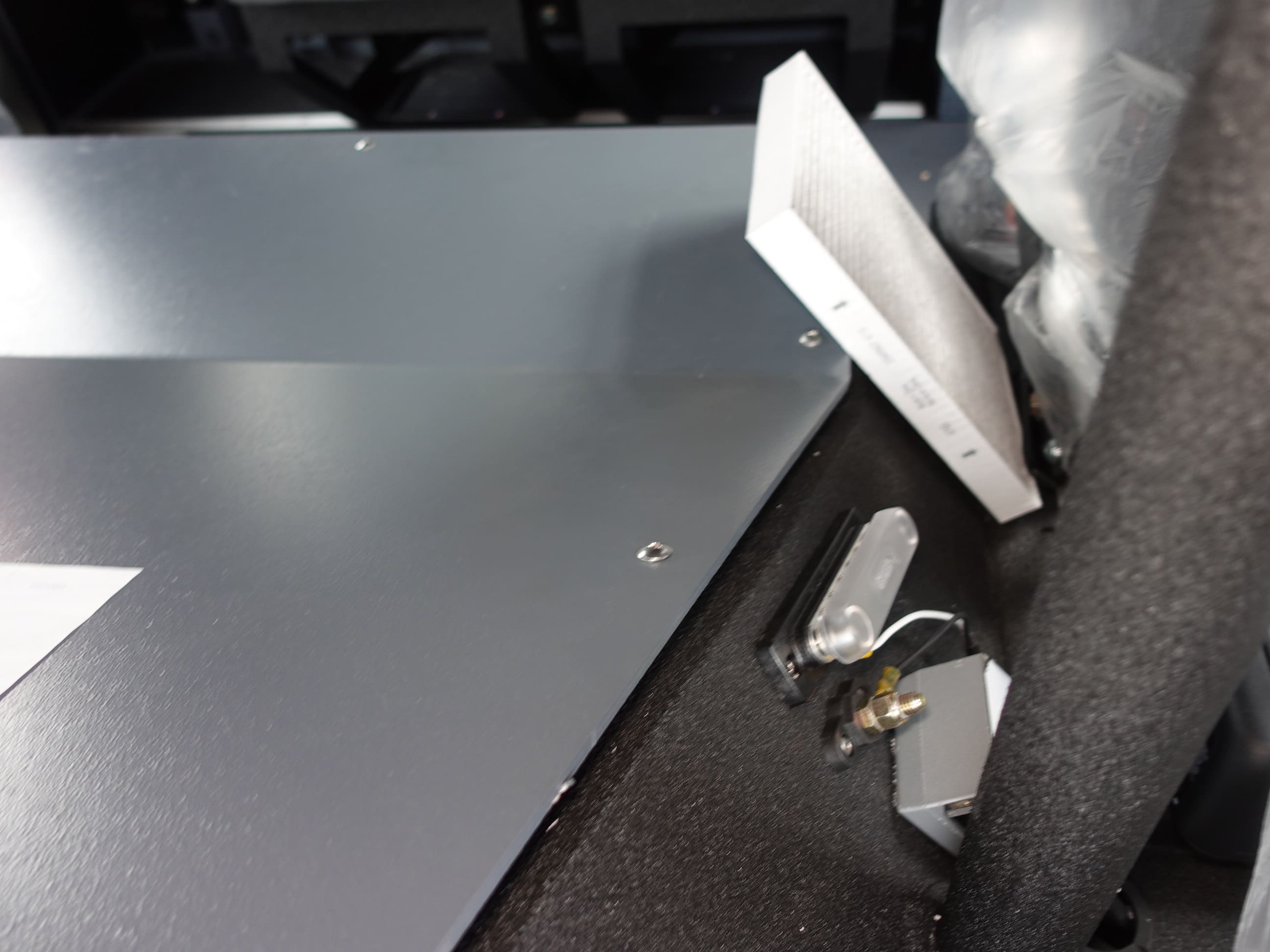

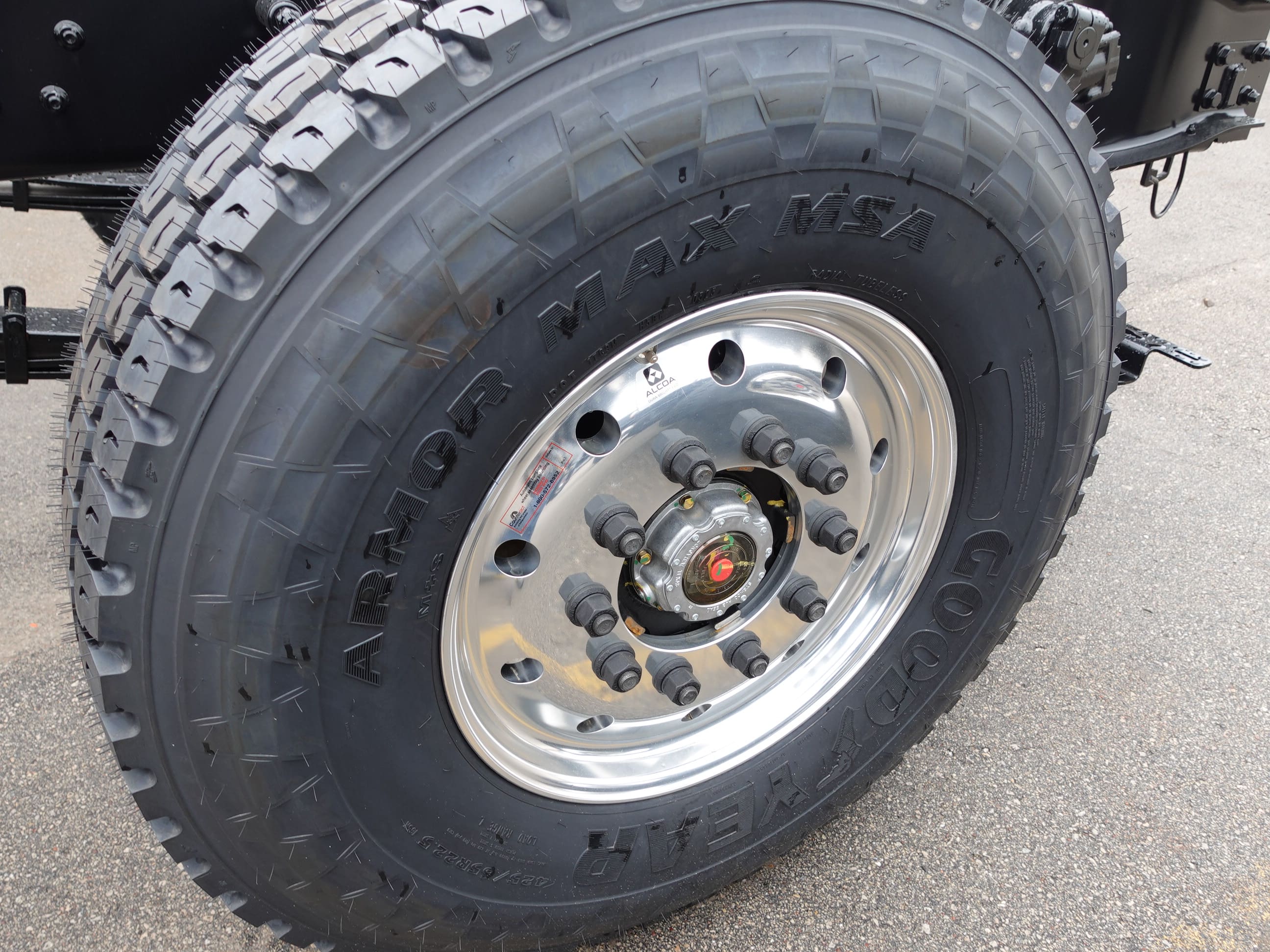

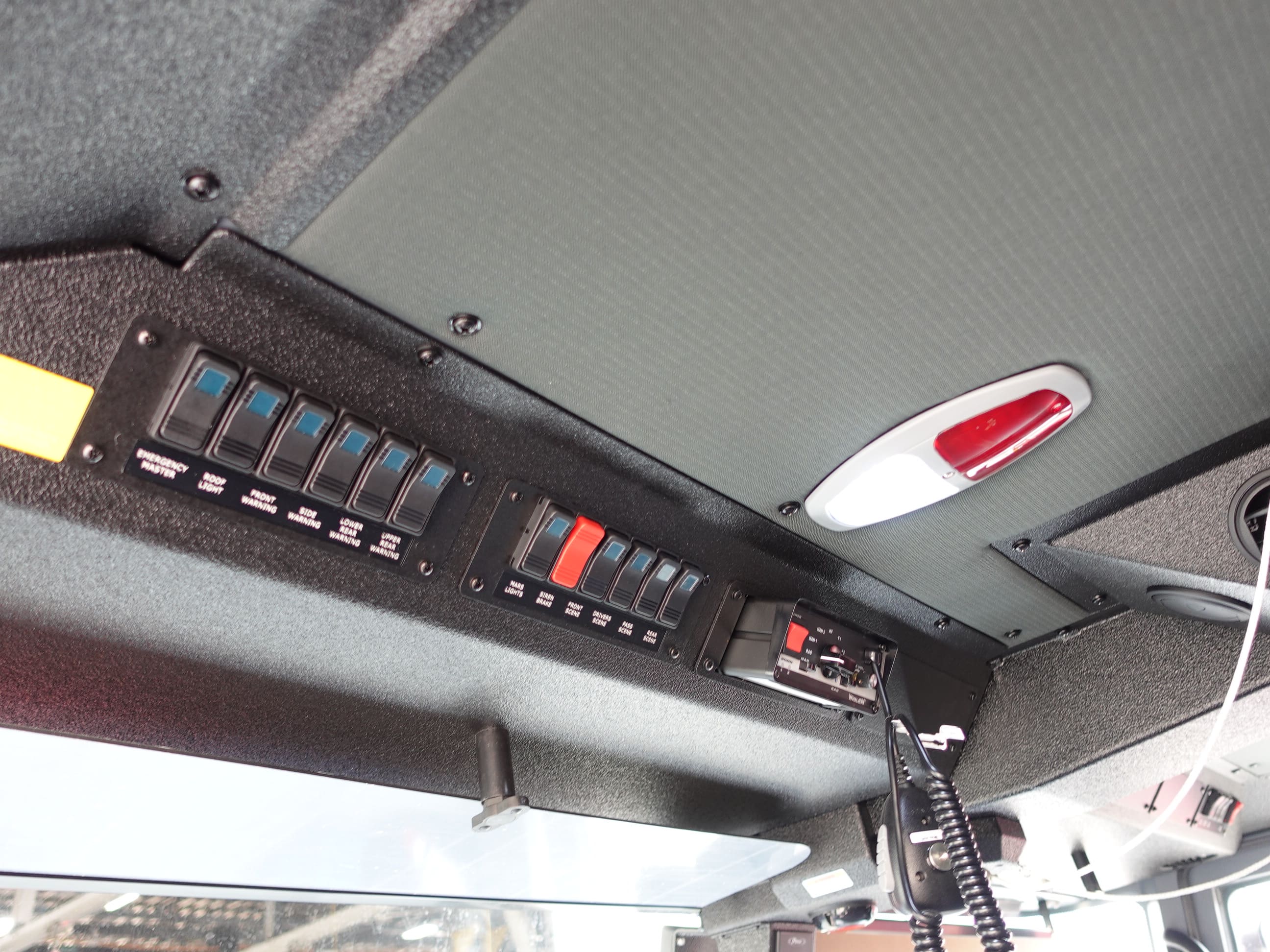

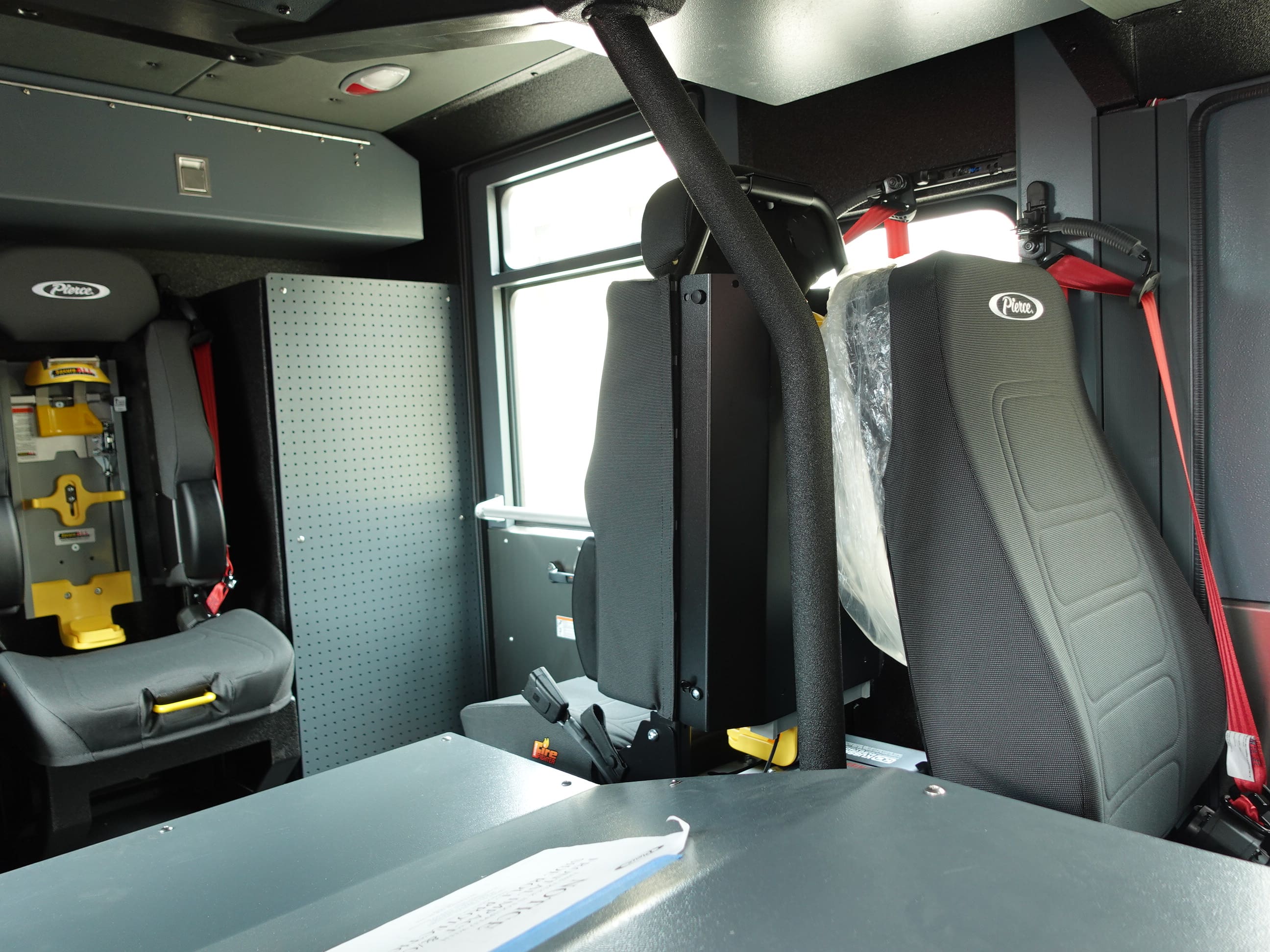

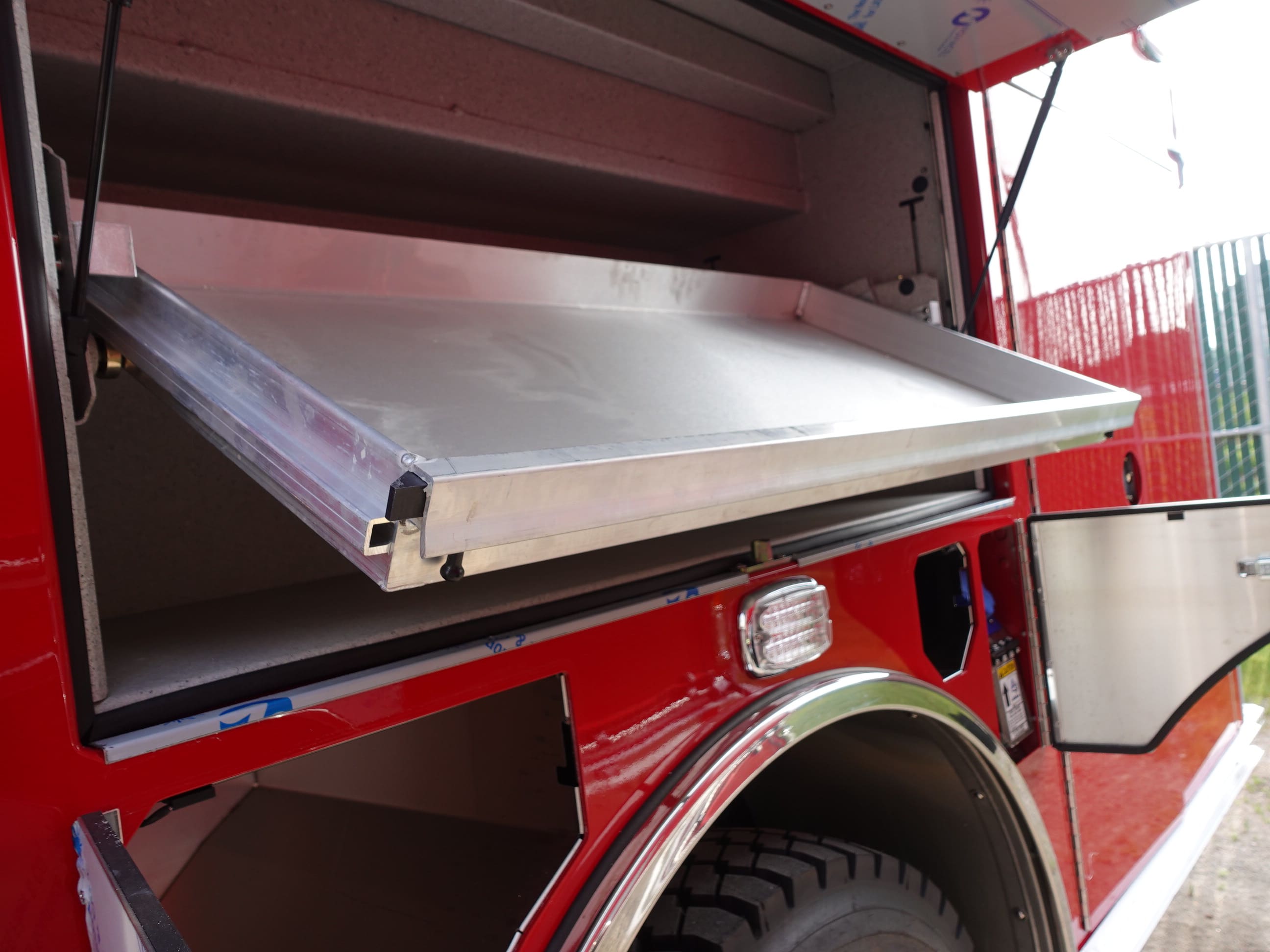

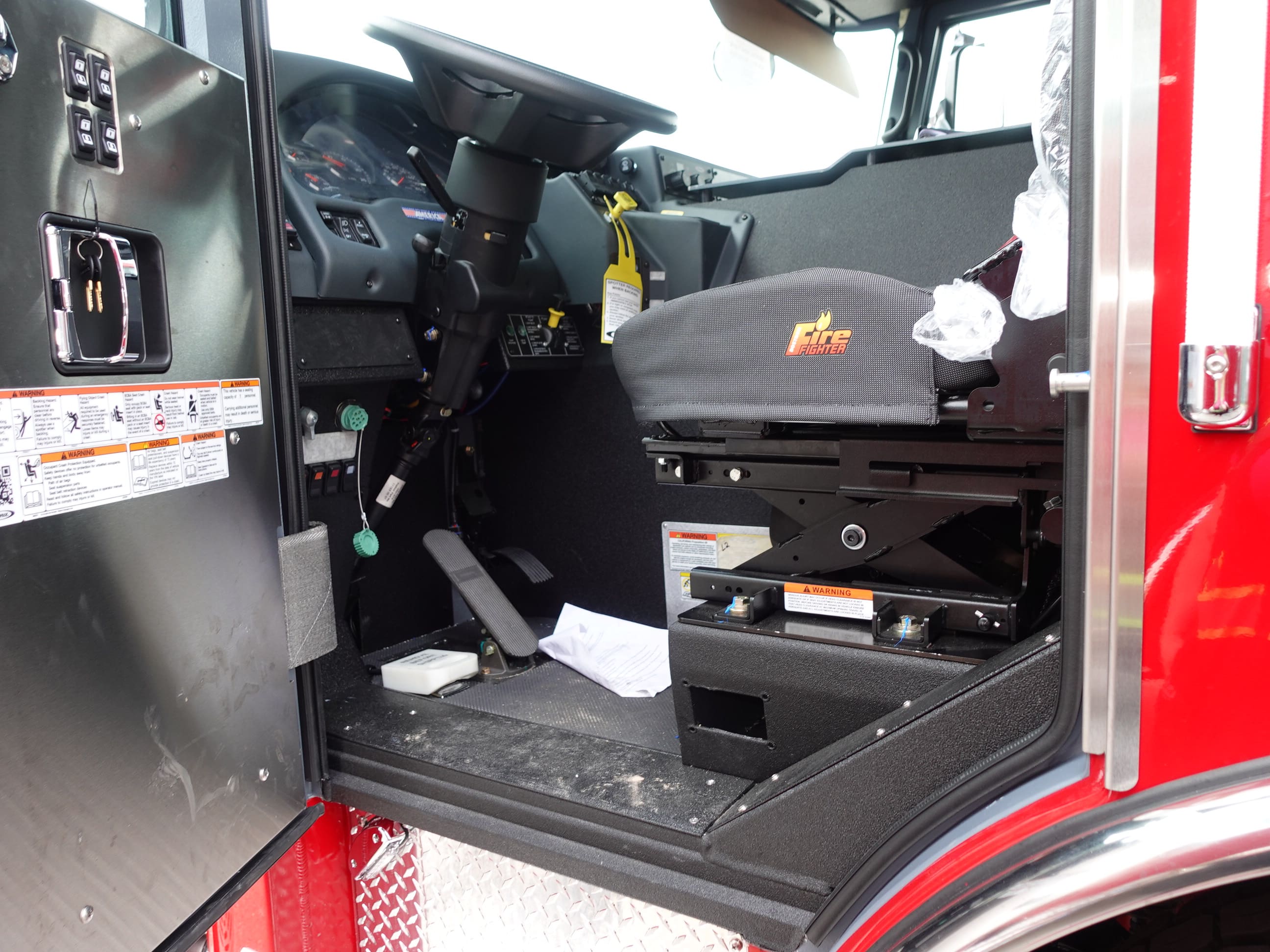

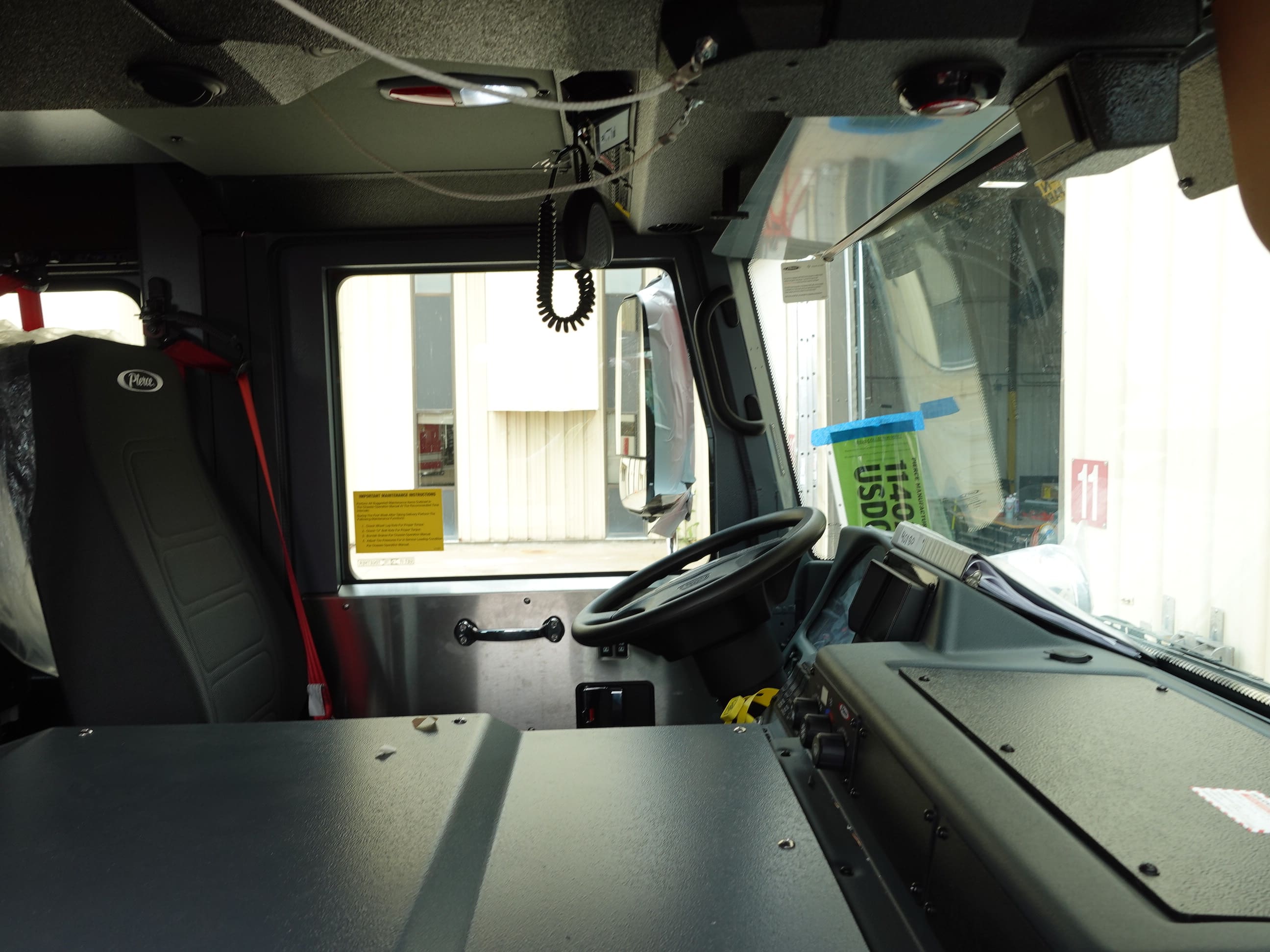

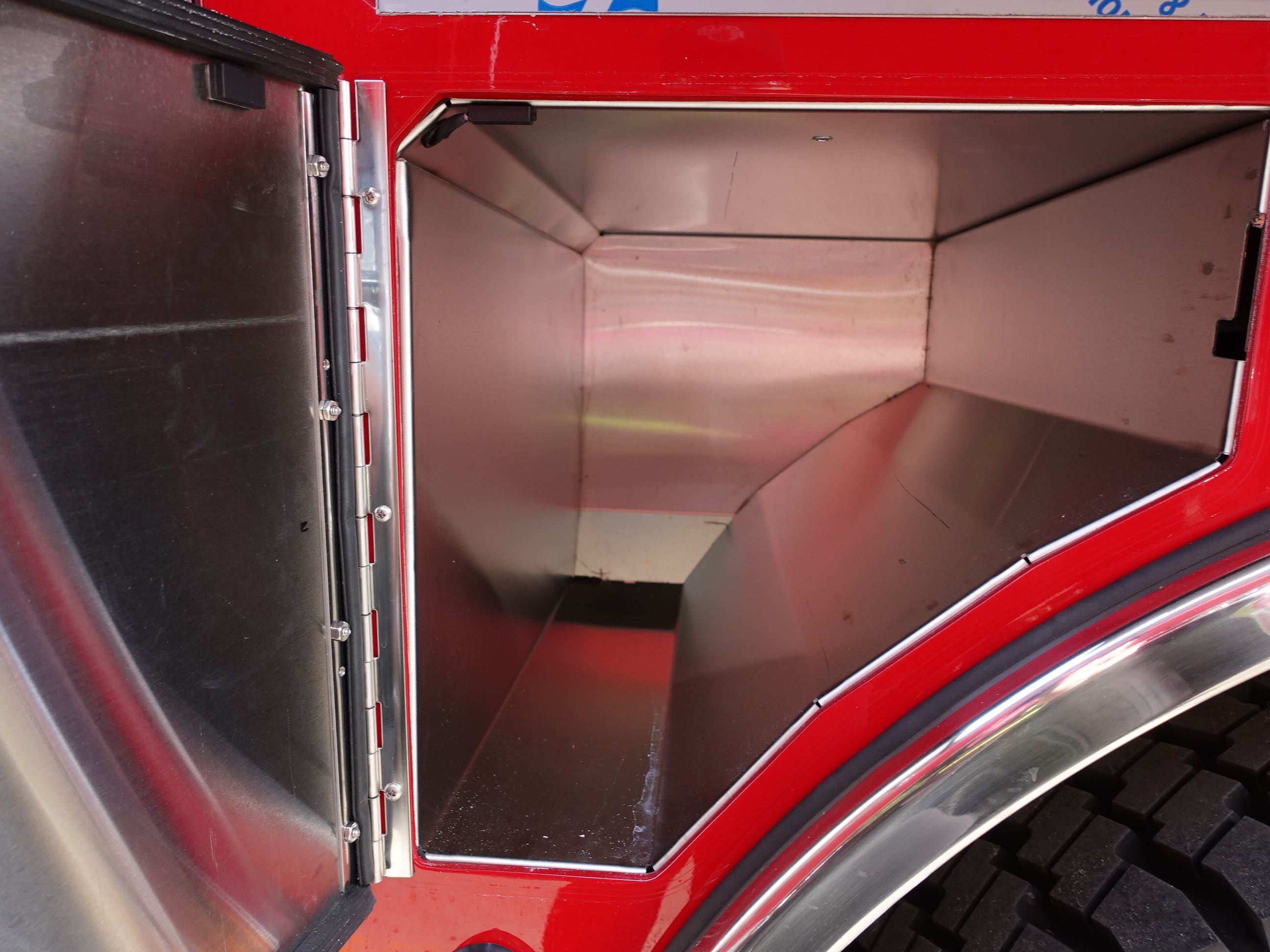

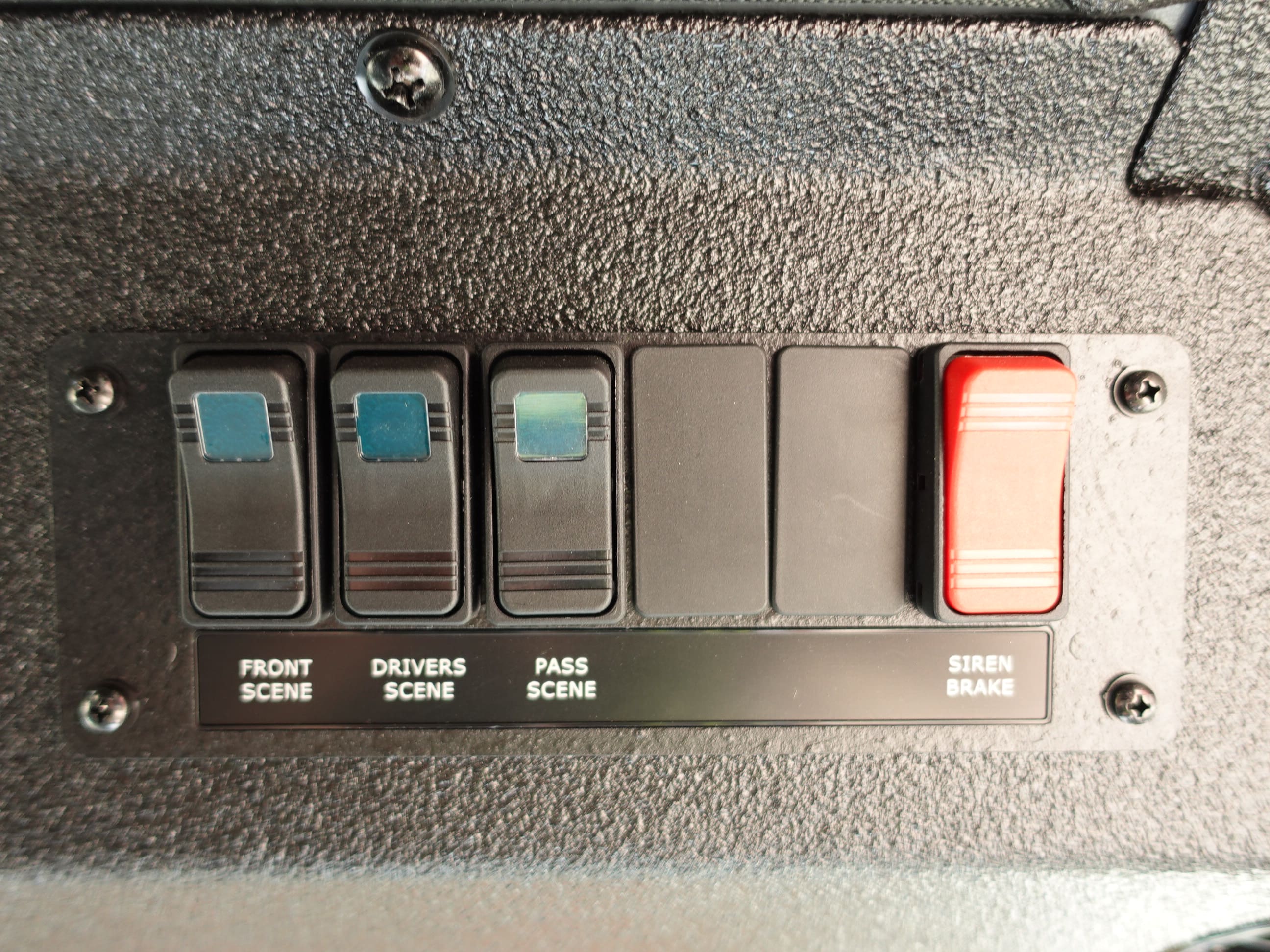

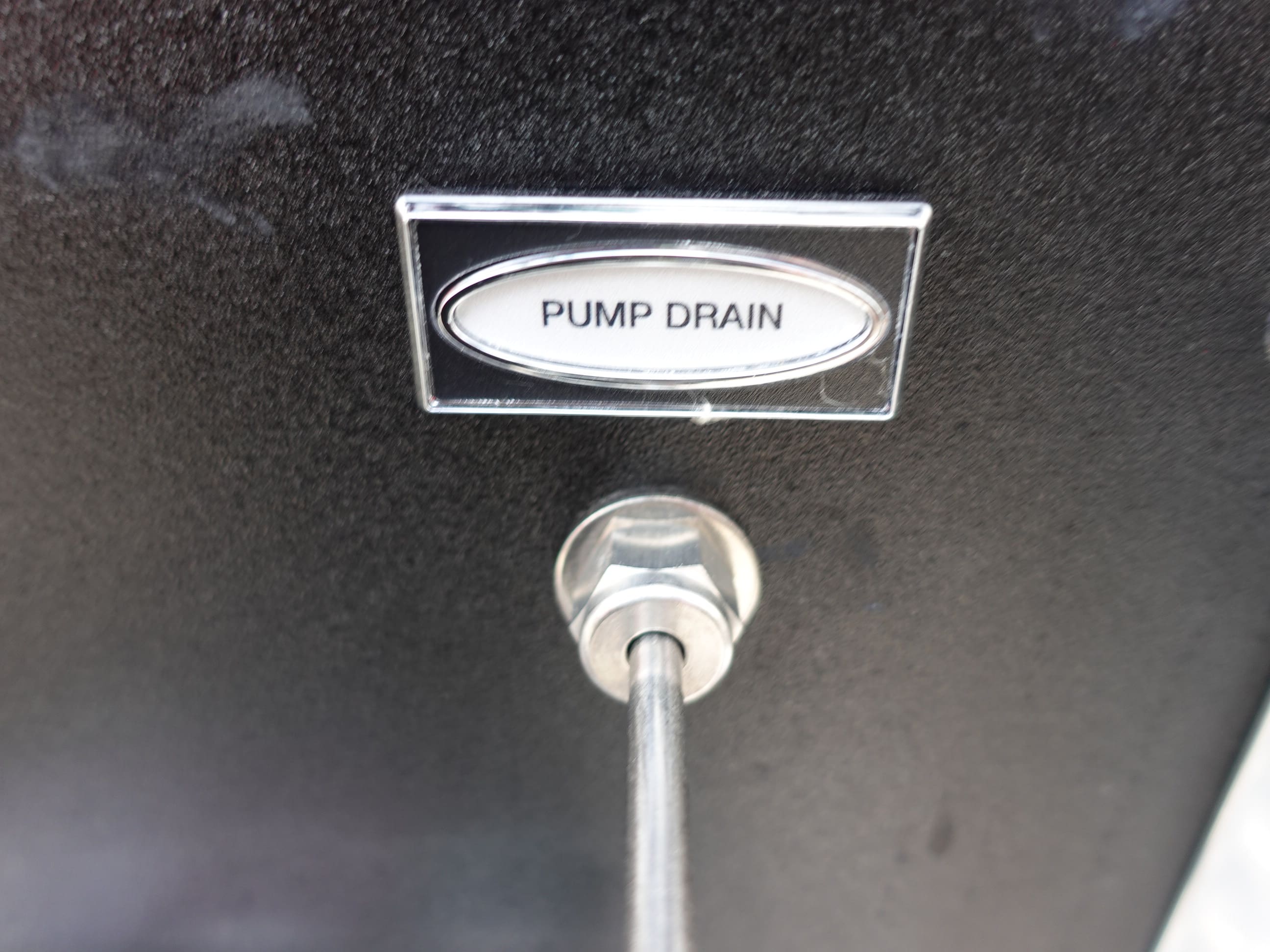

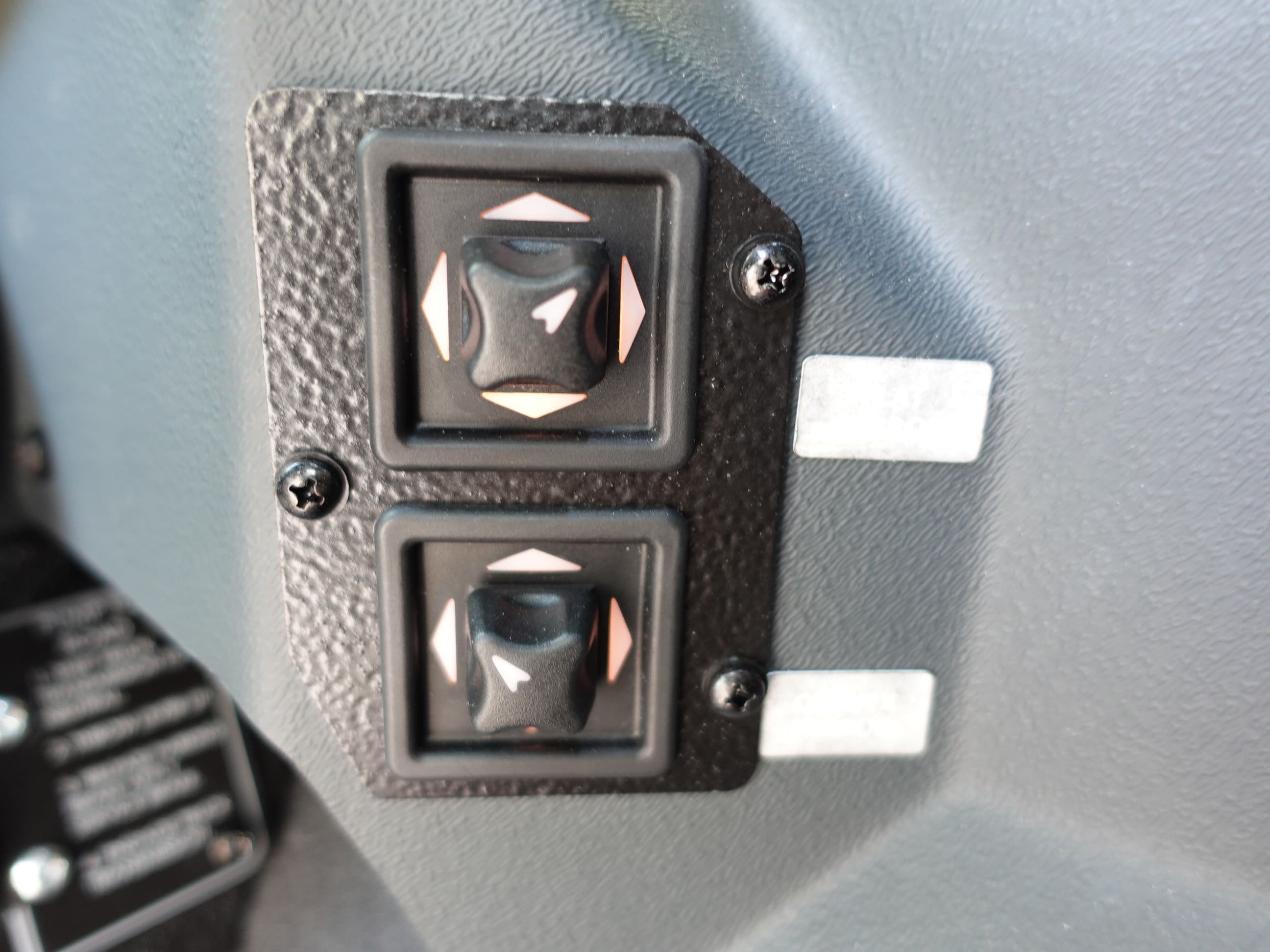

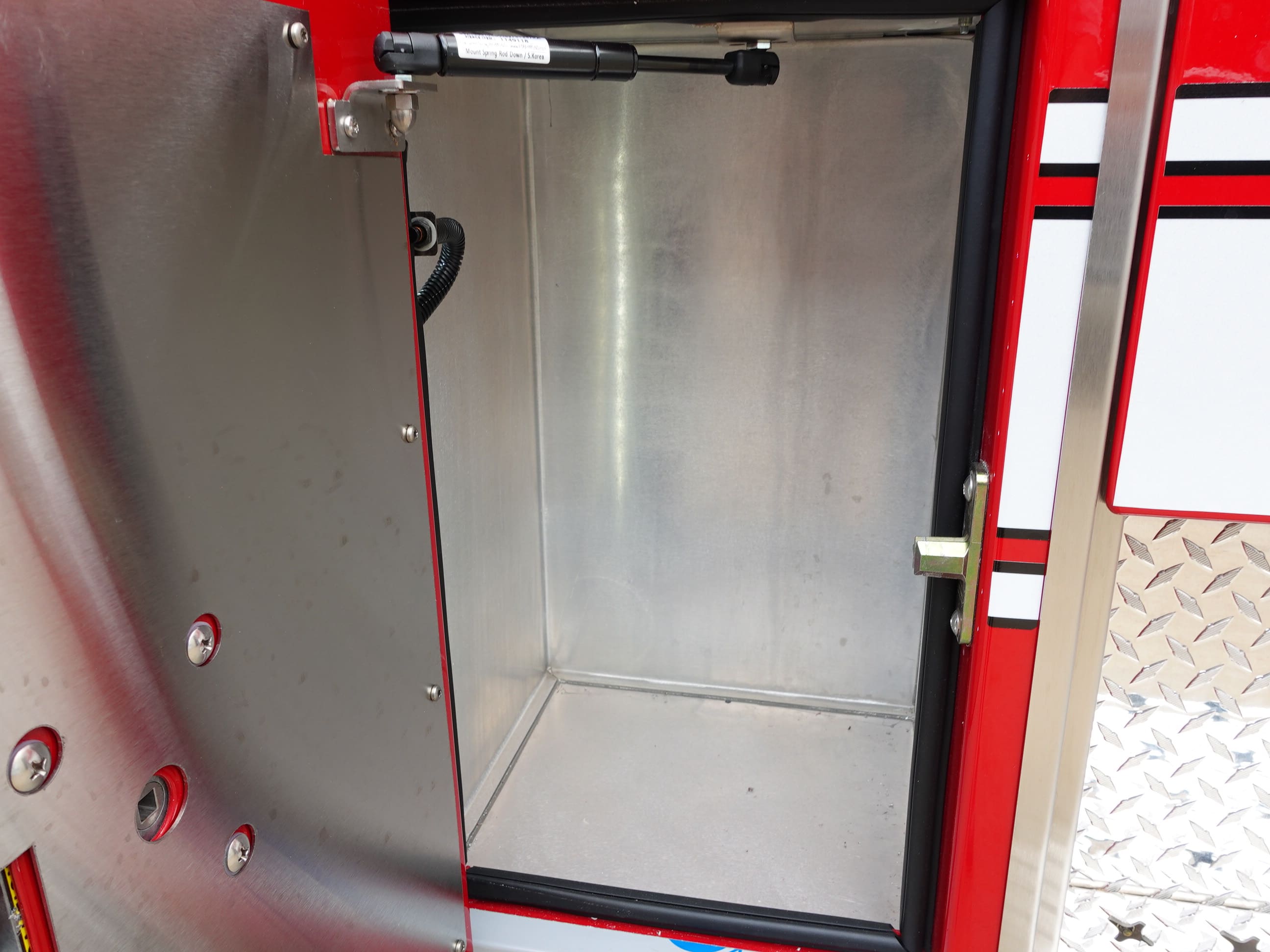

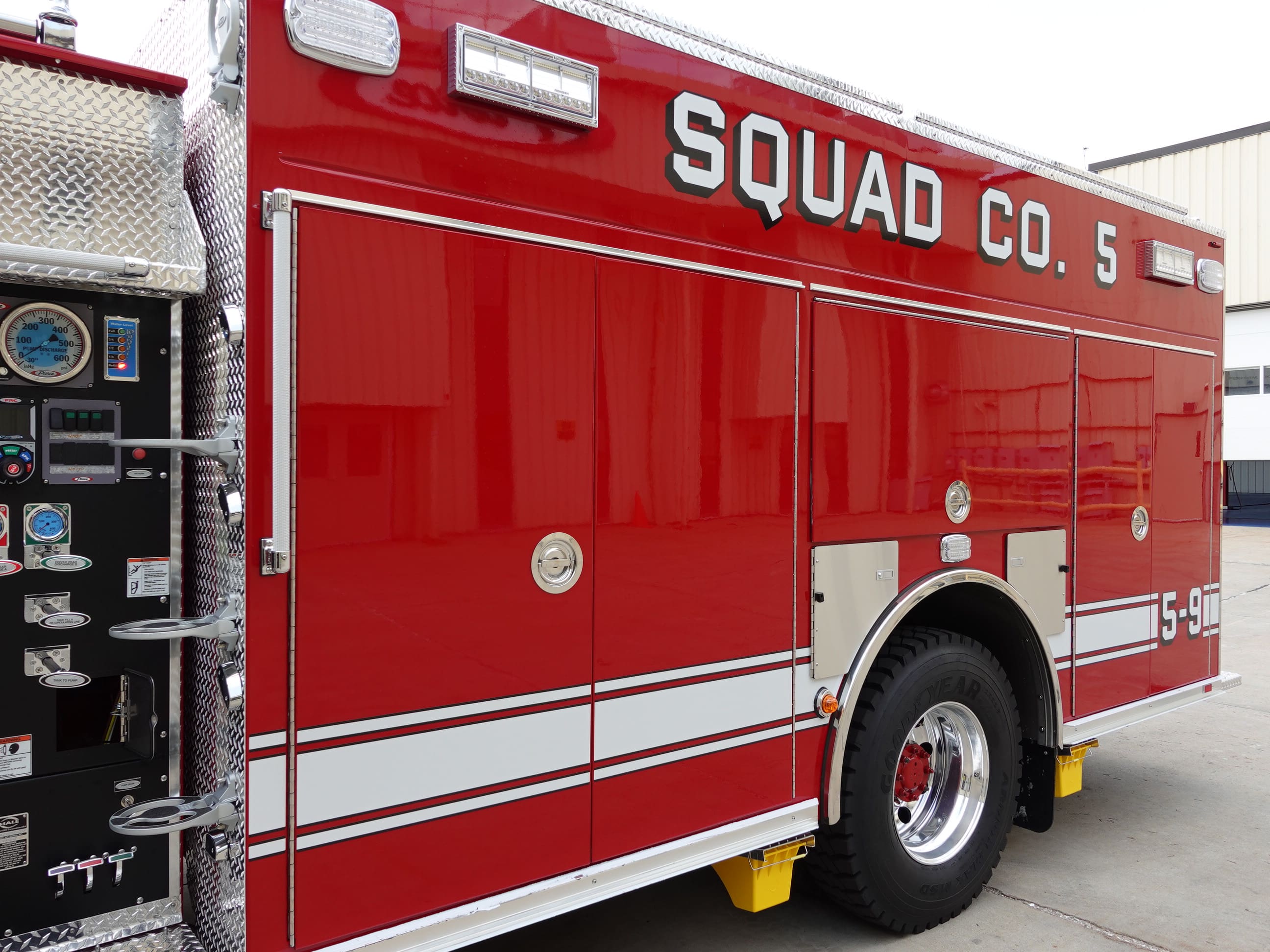

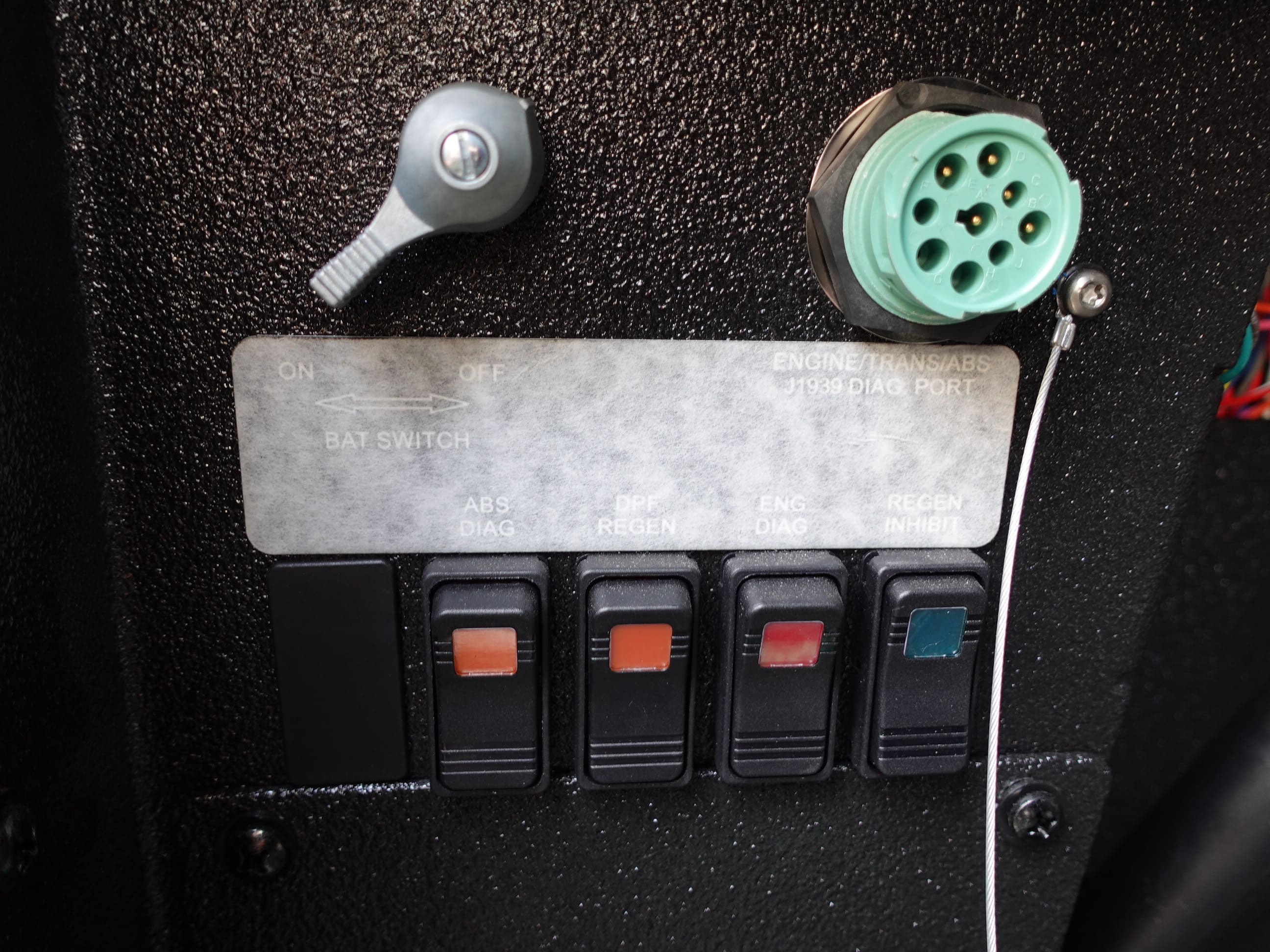

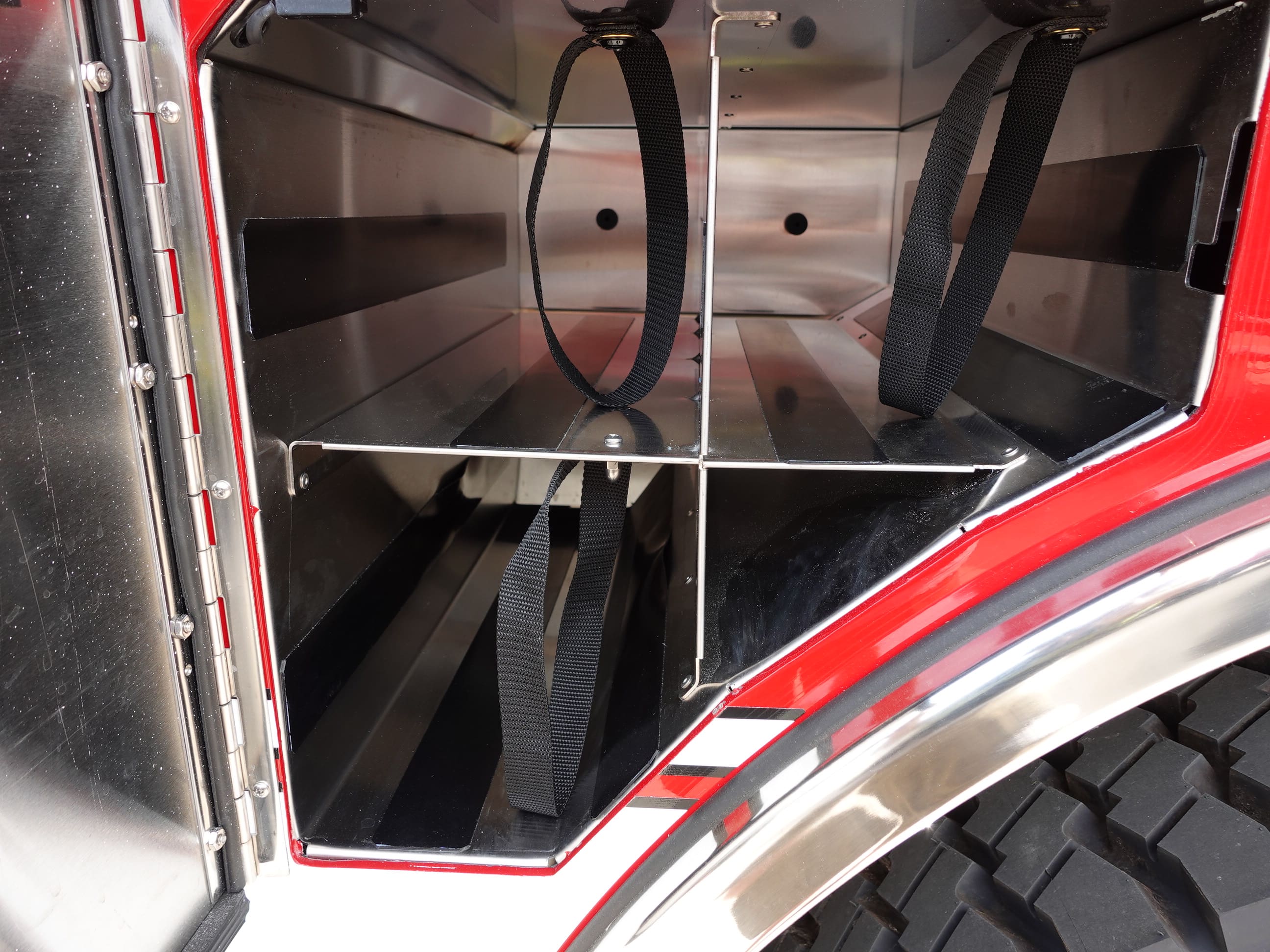

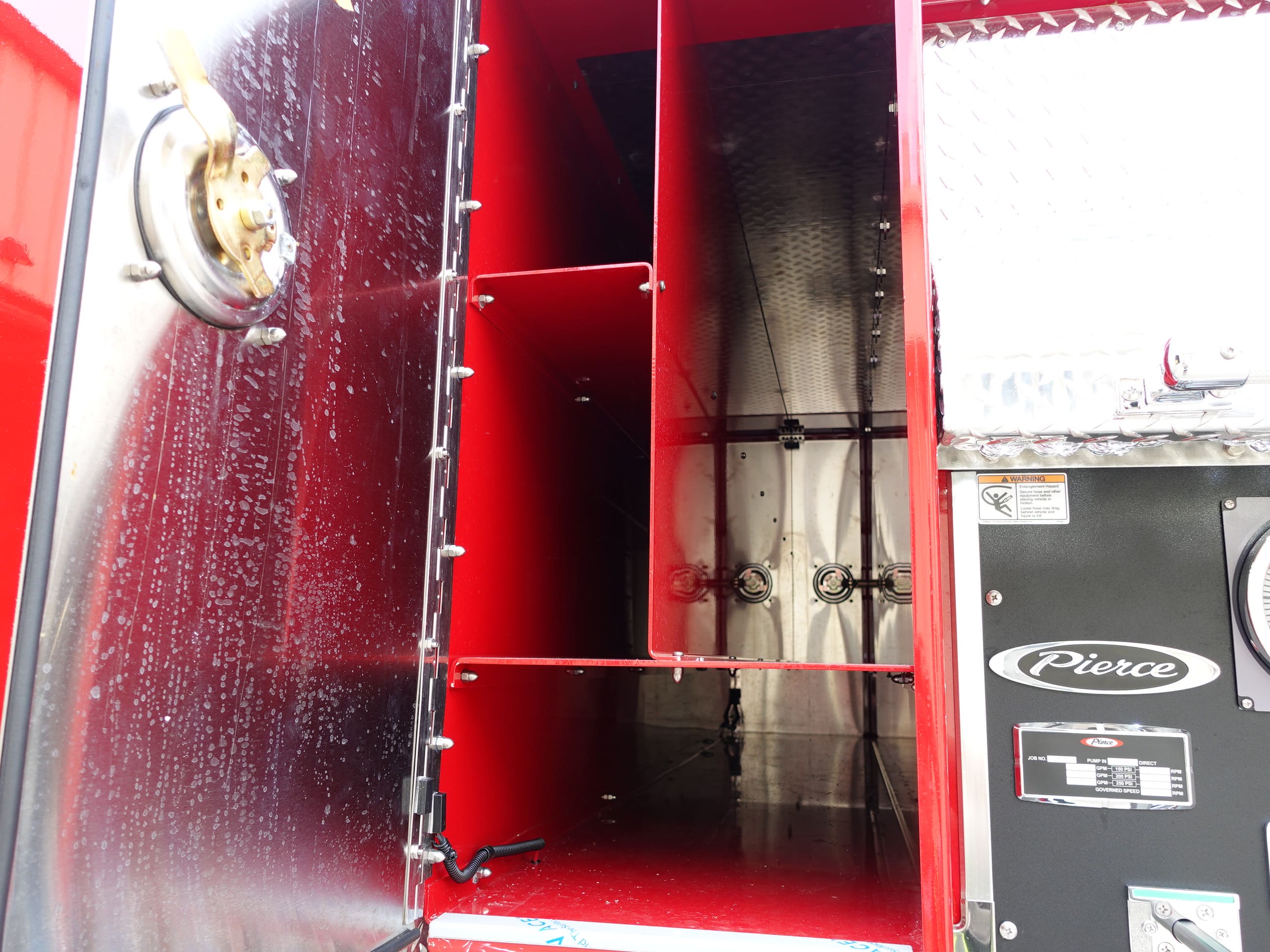

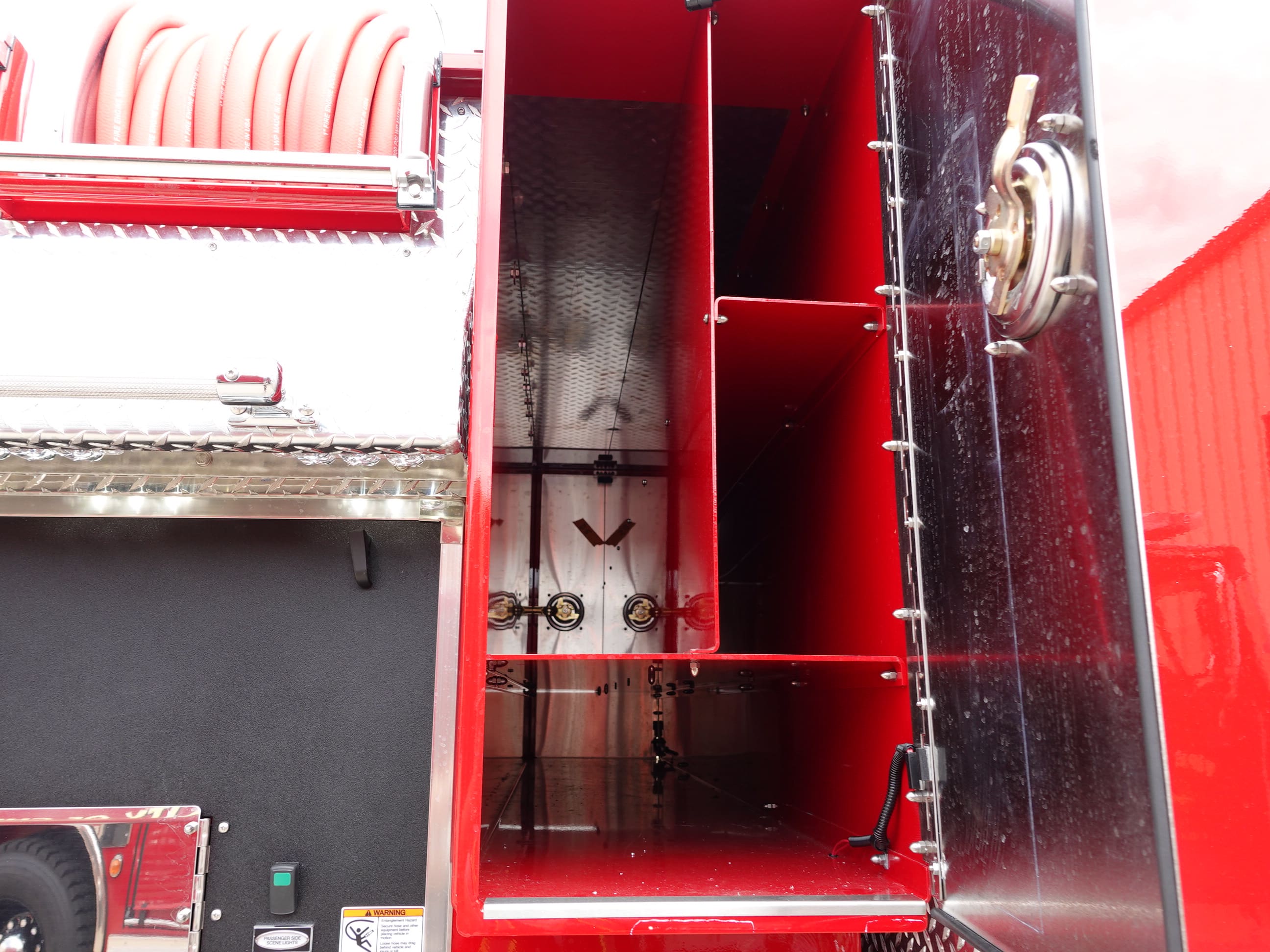

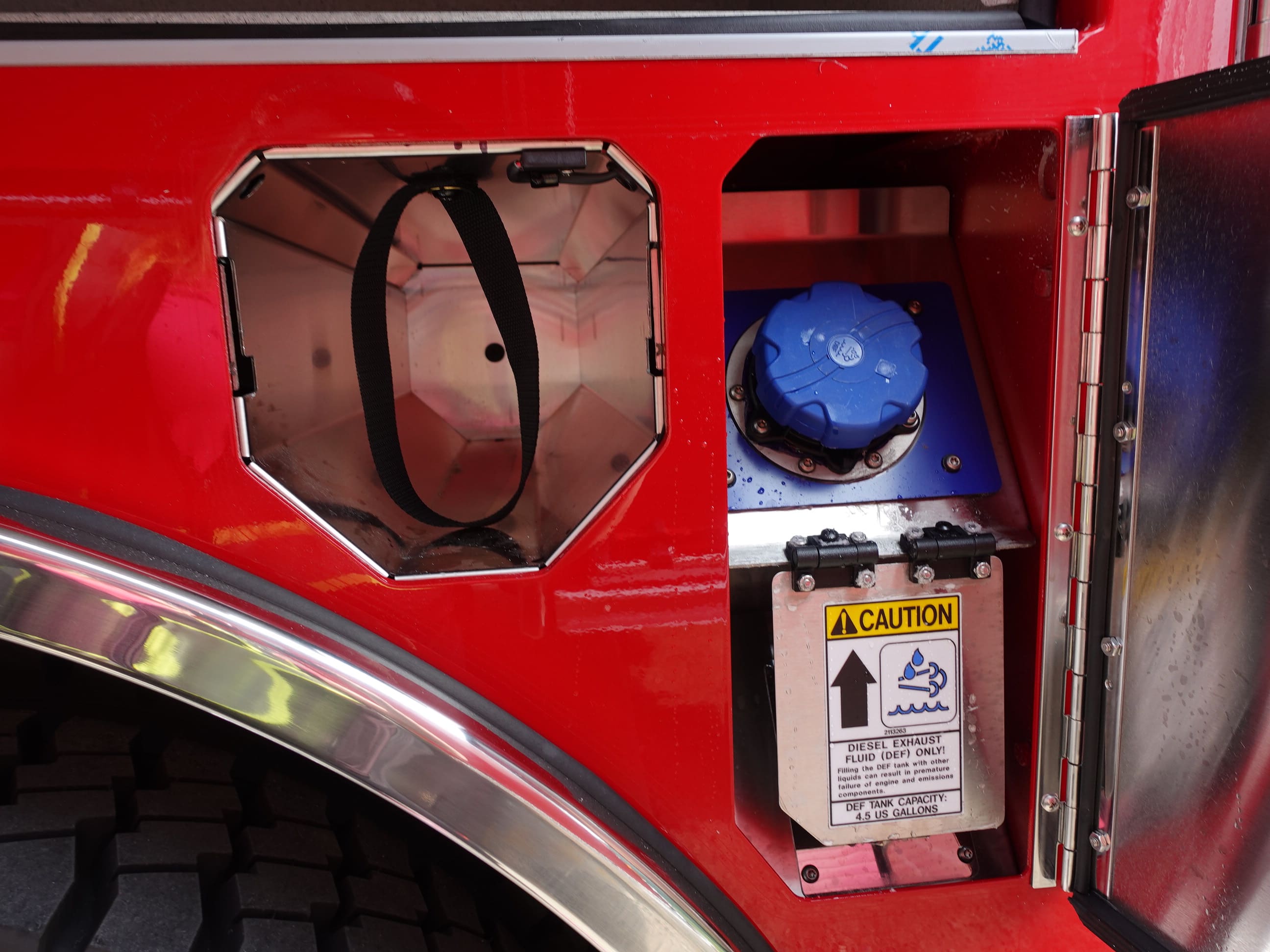

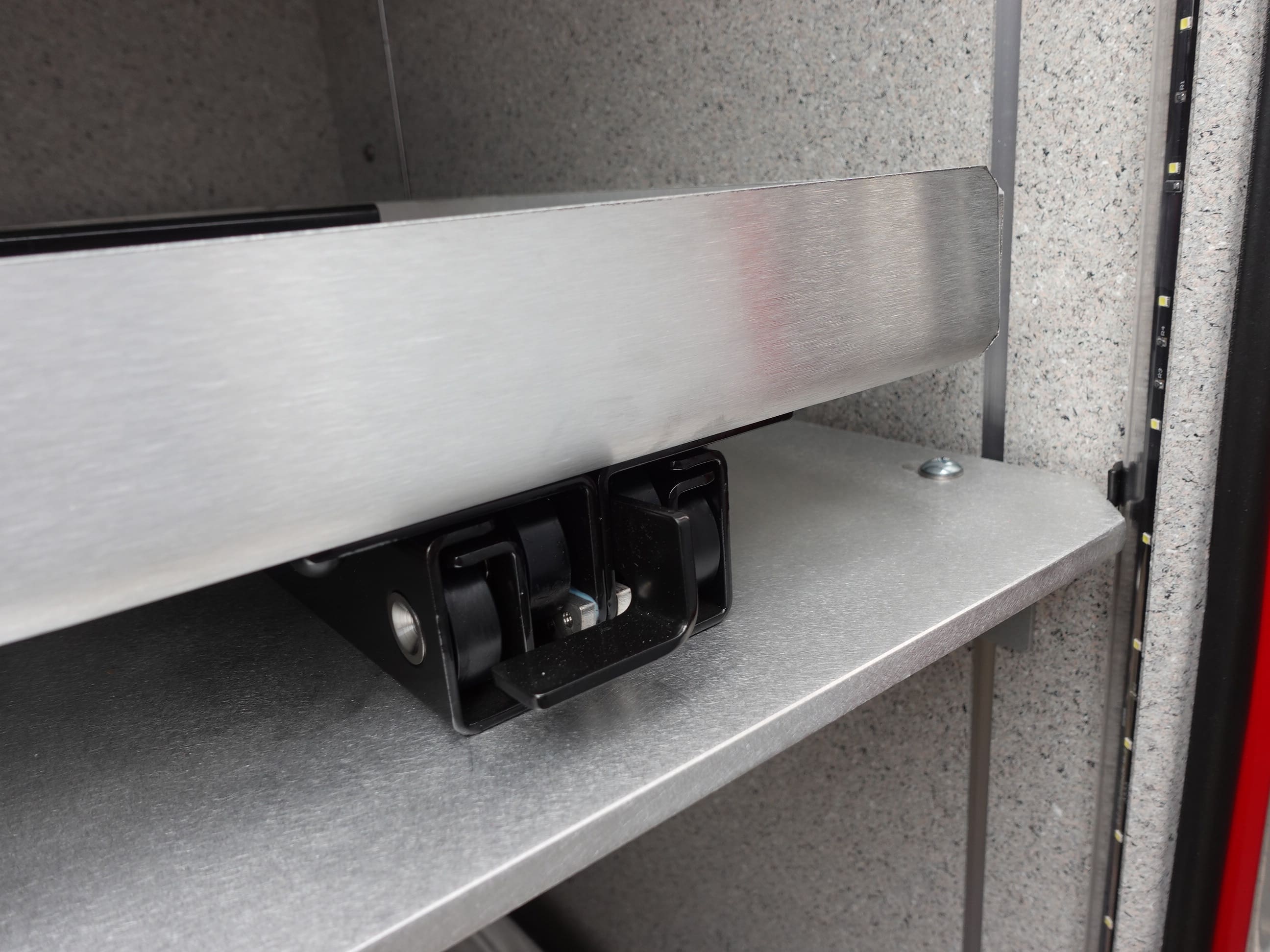

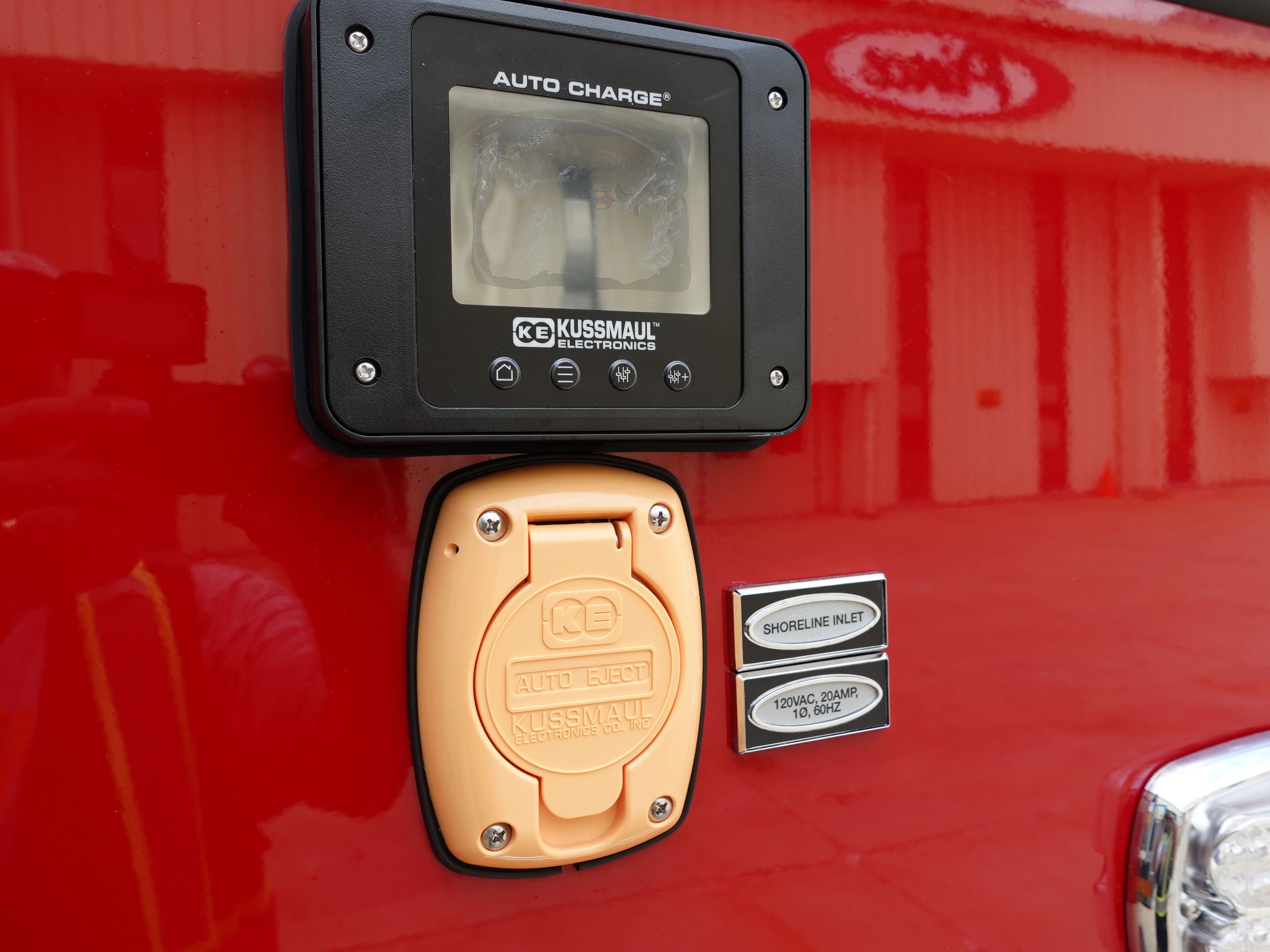

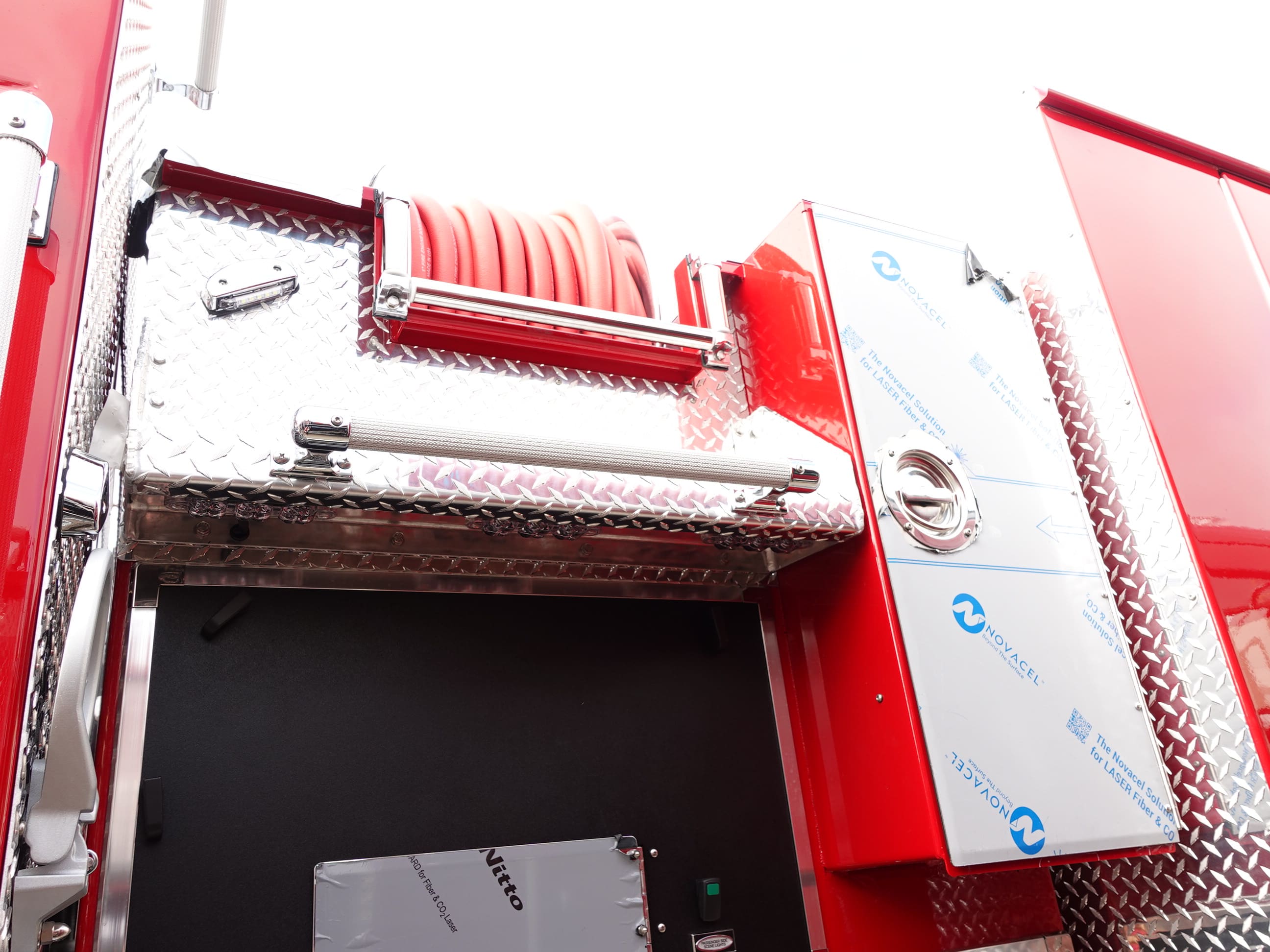

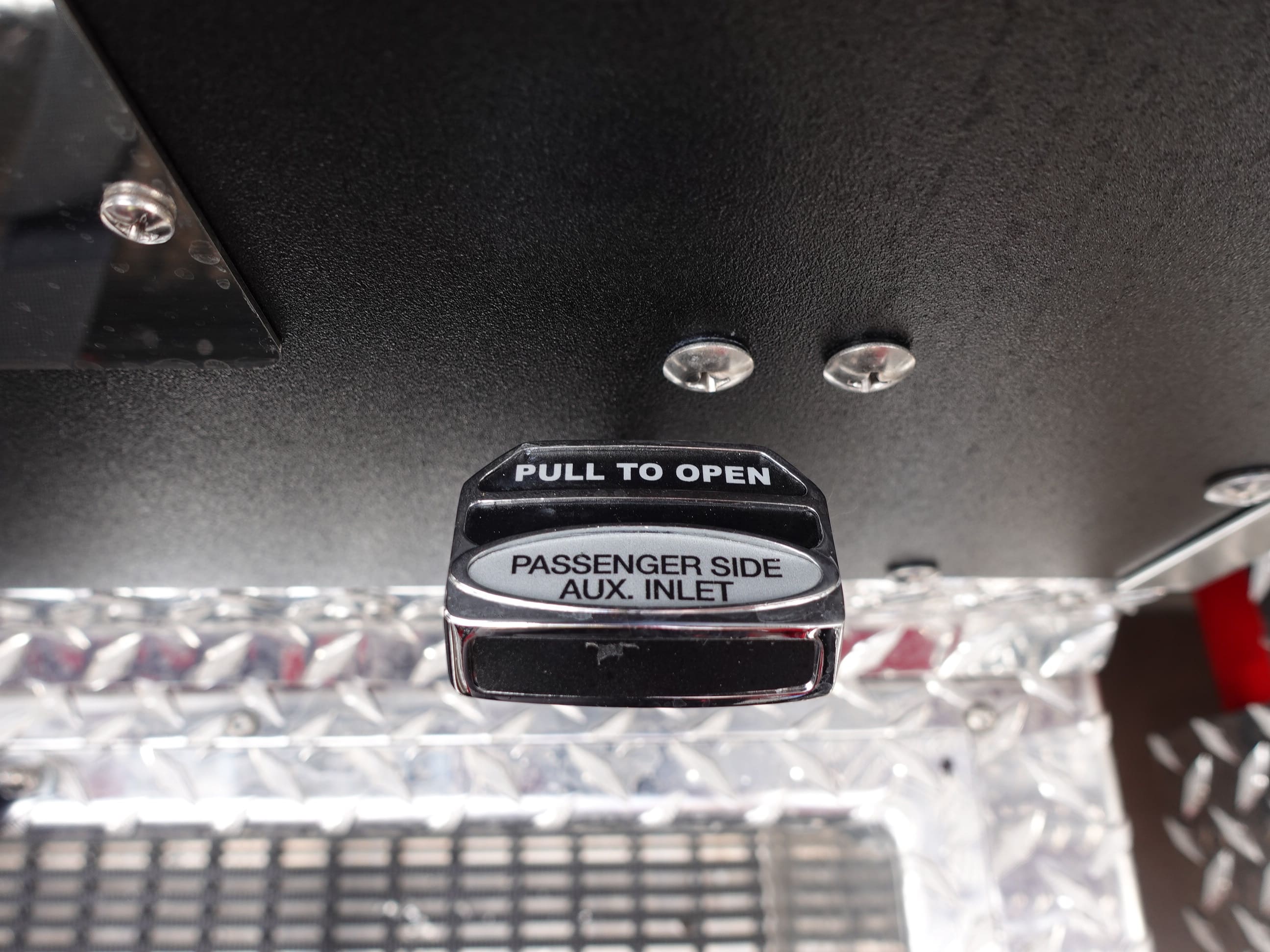

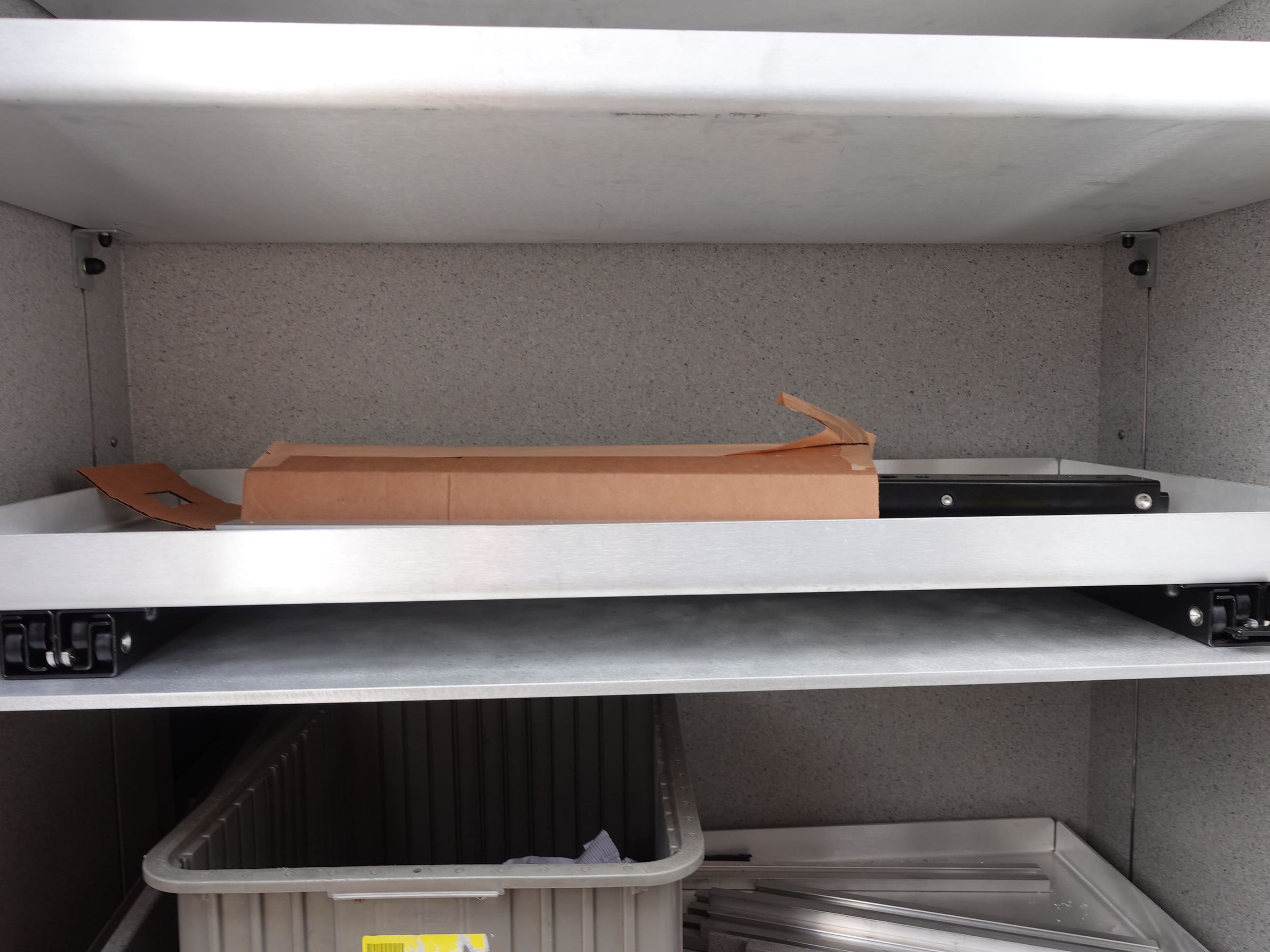

07-24-26

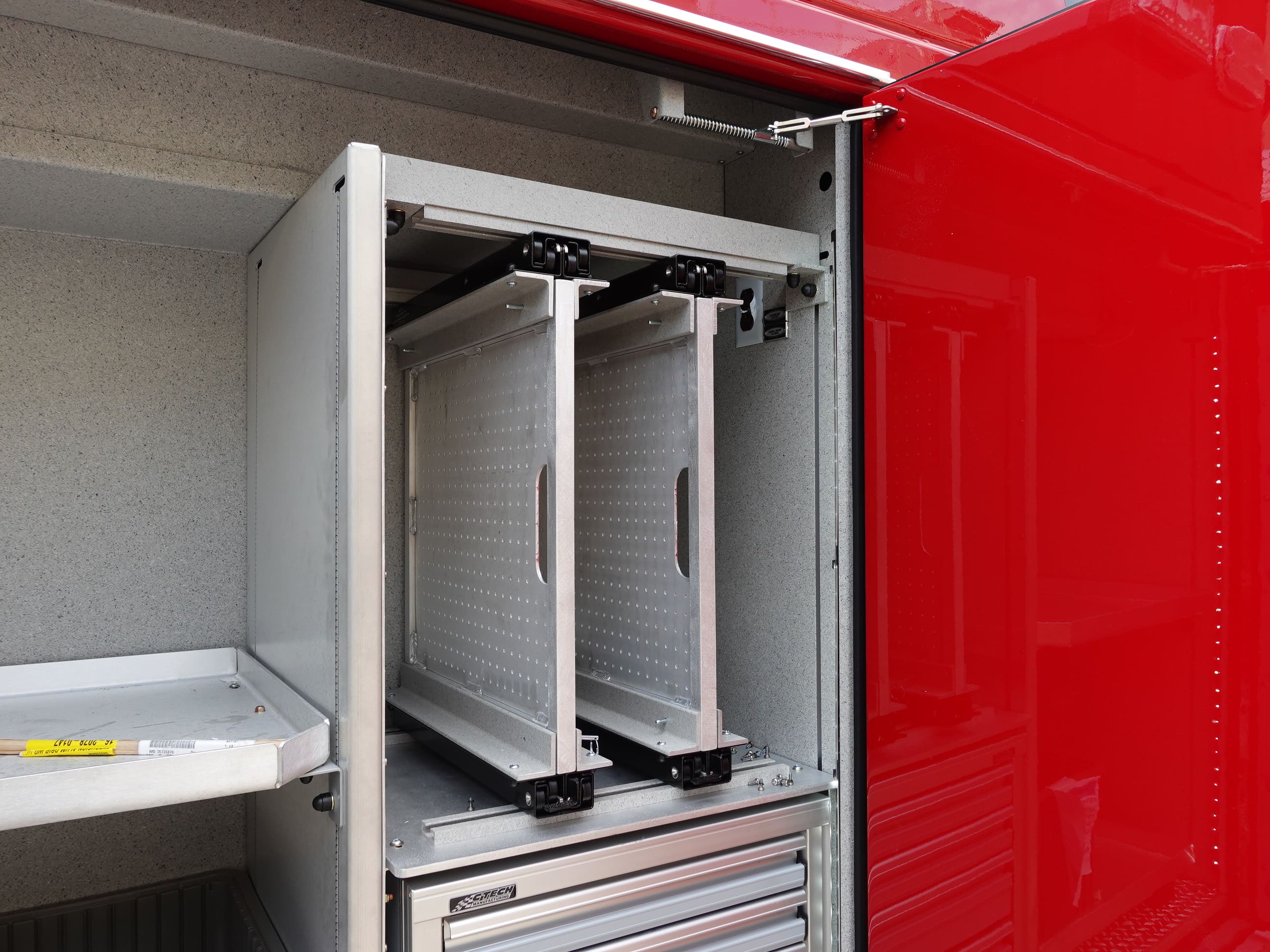

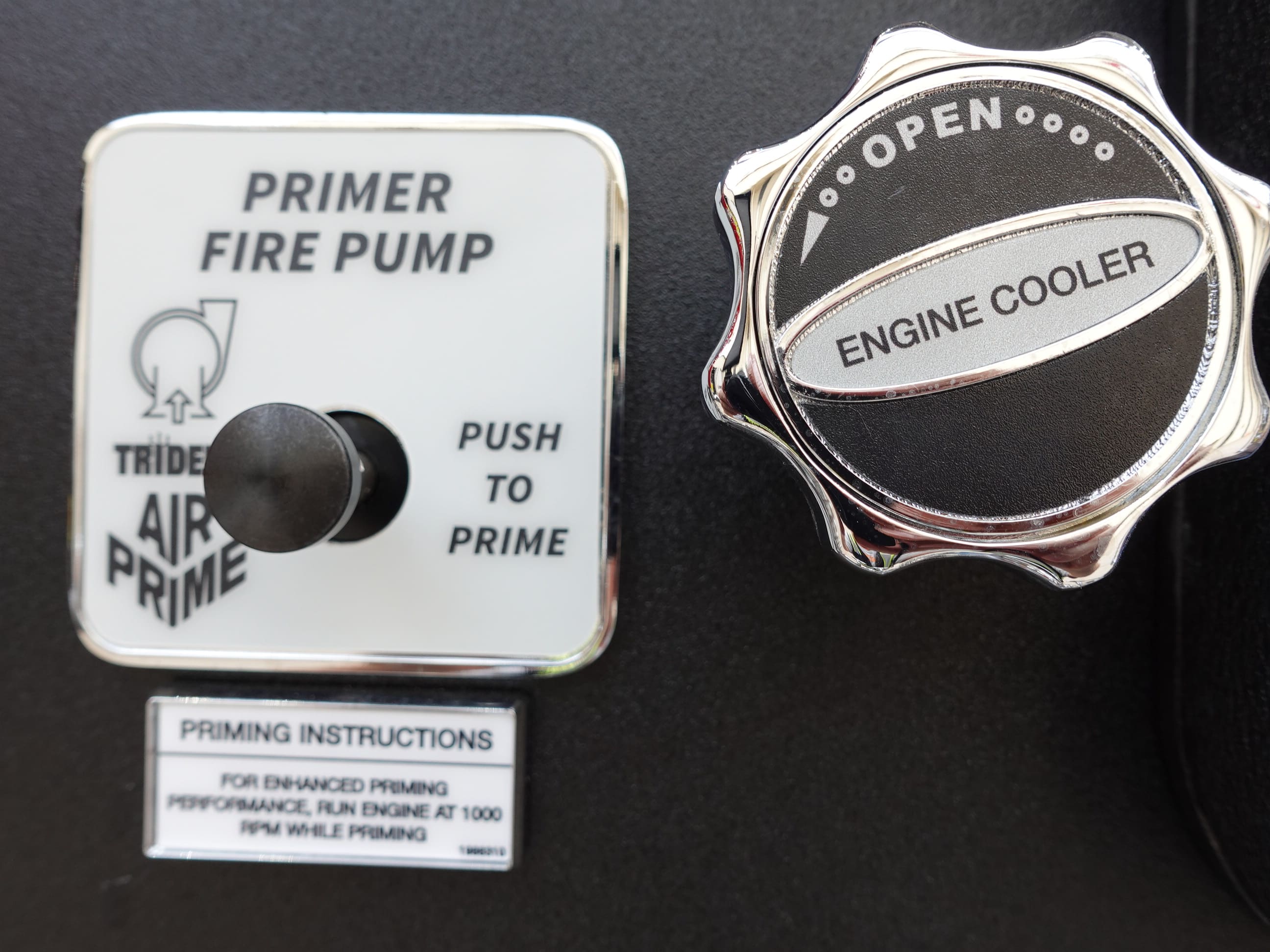

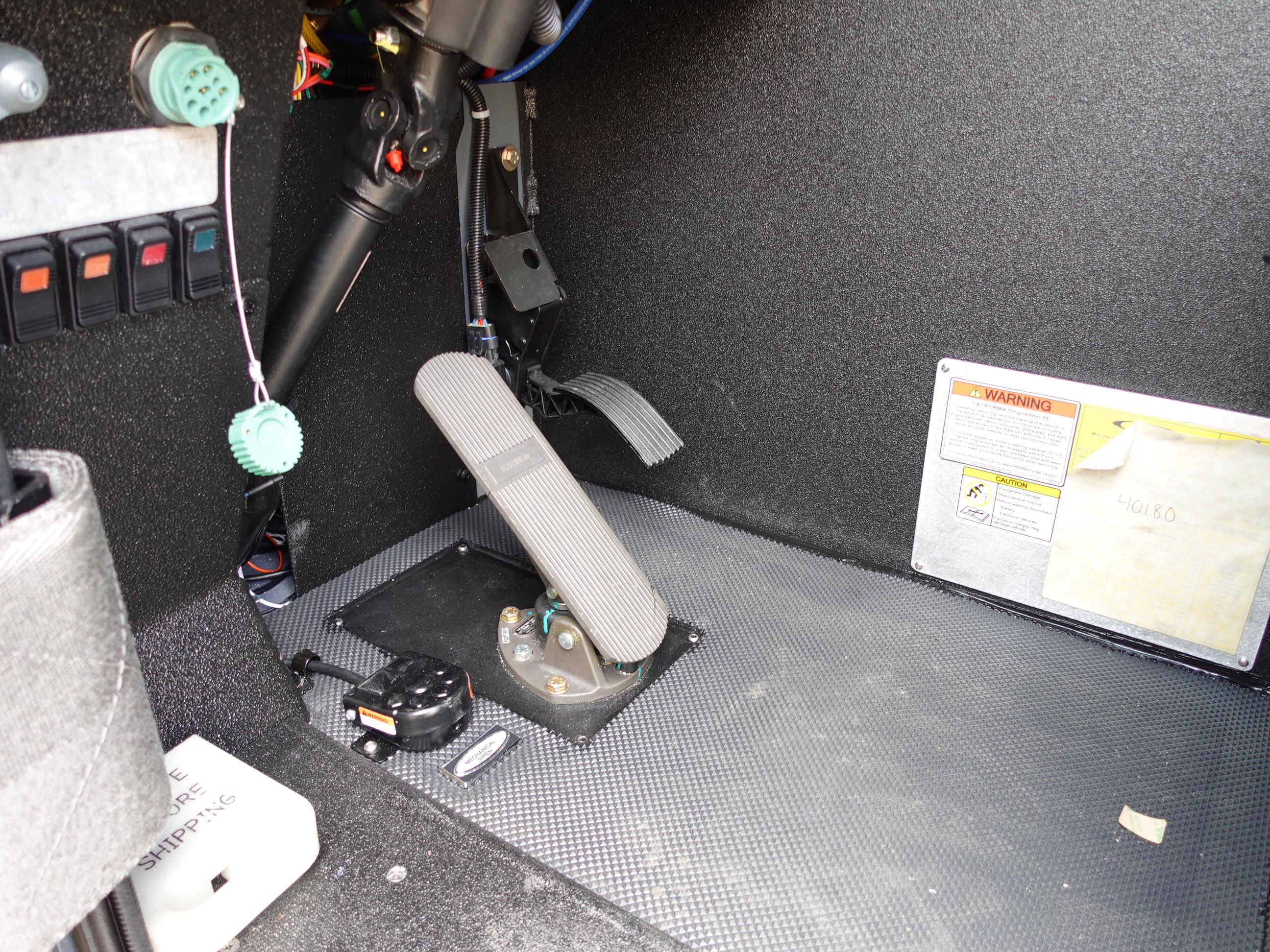

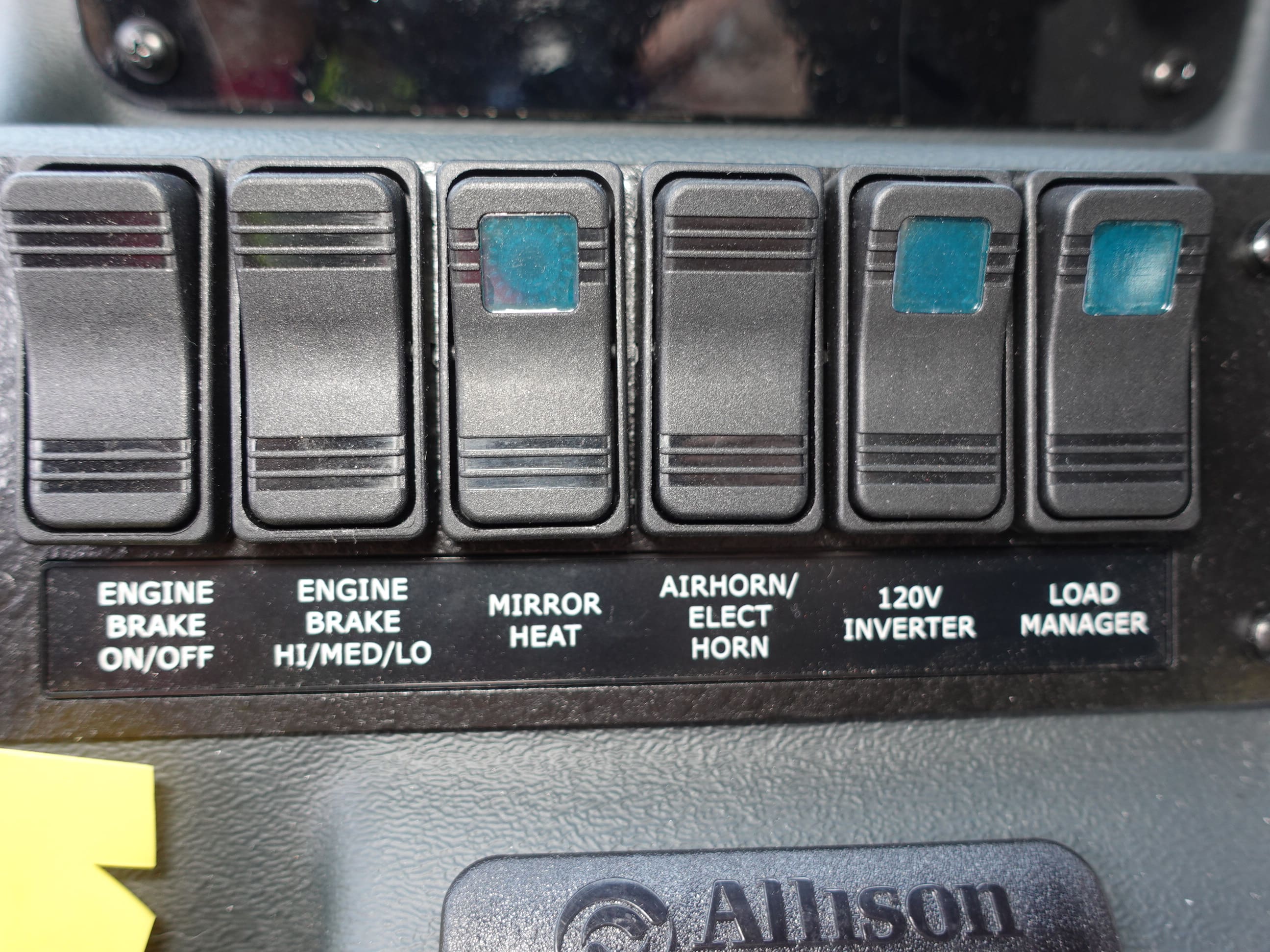

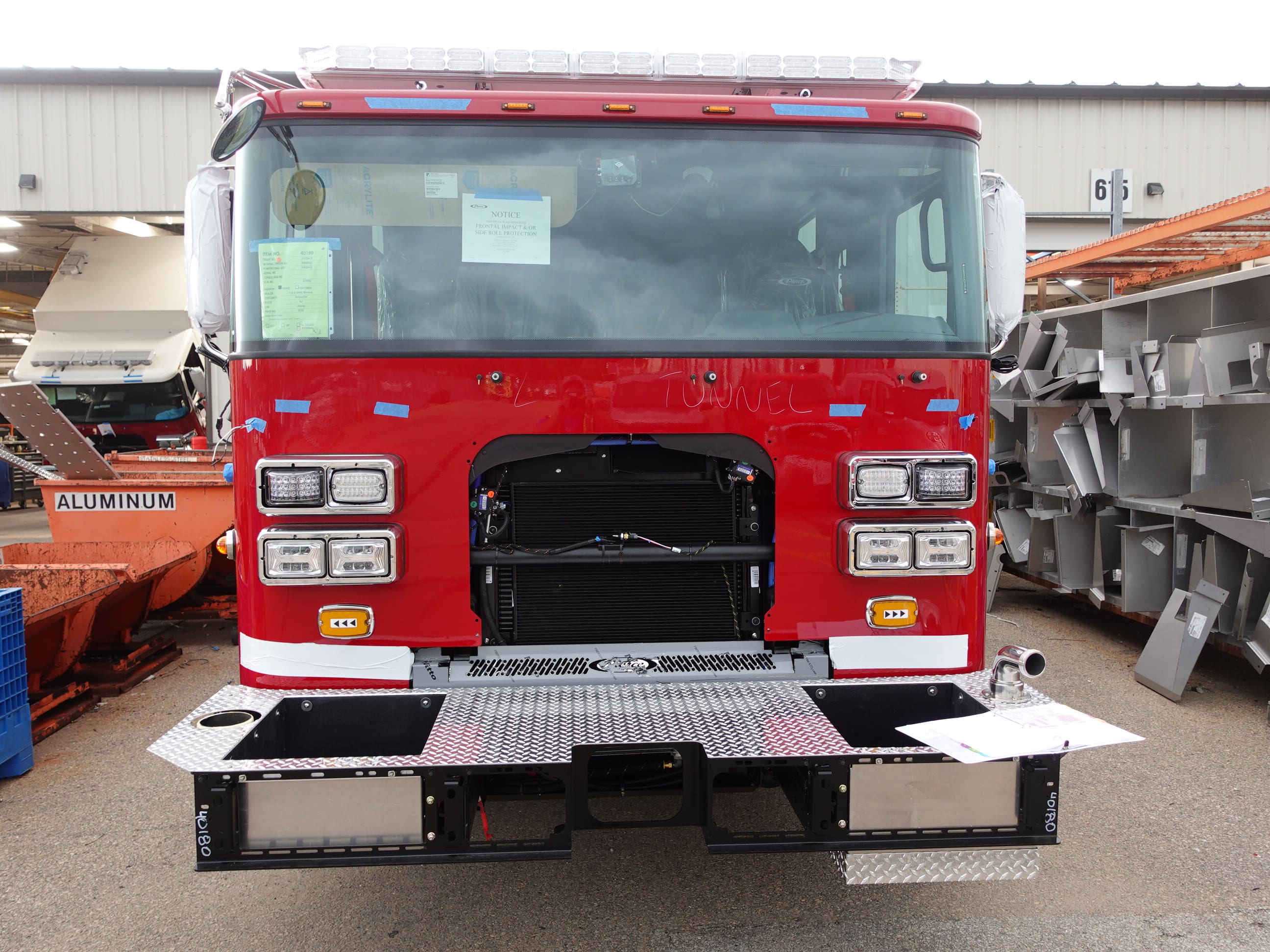

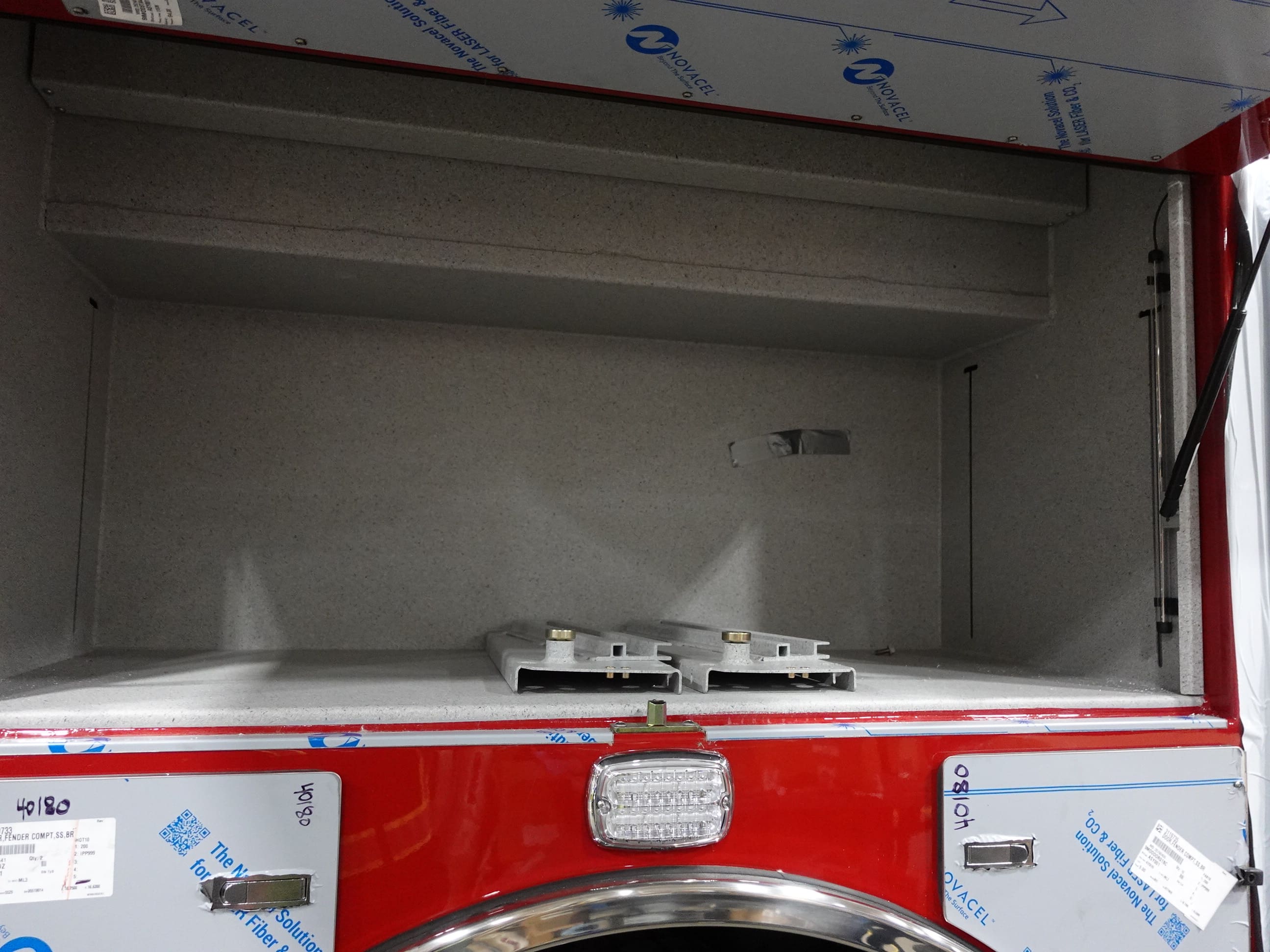

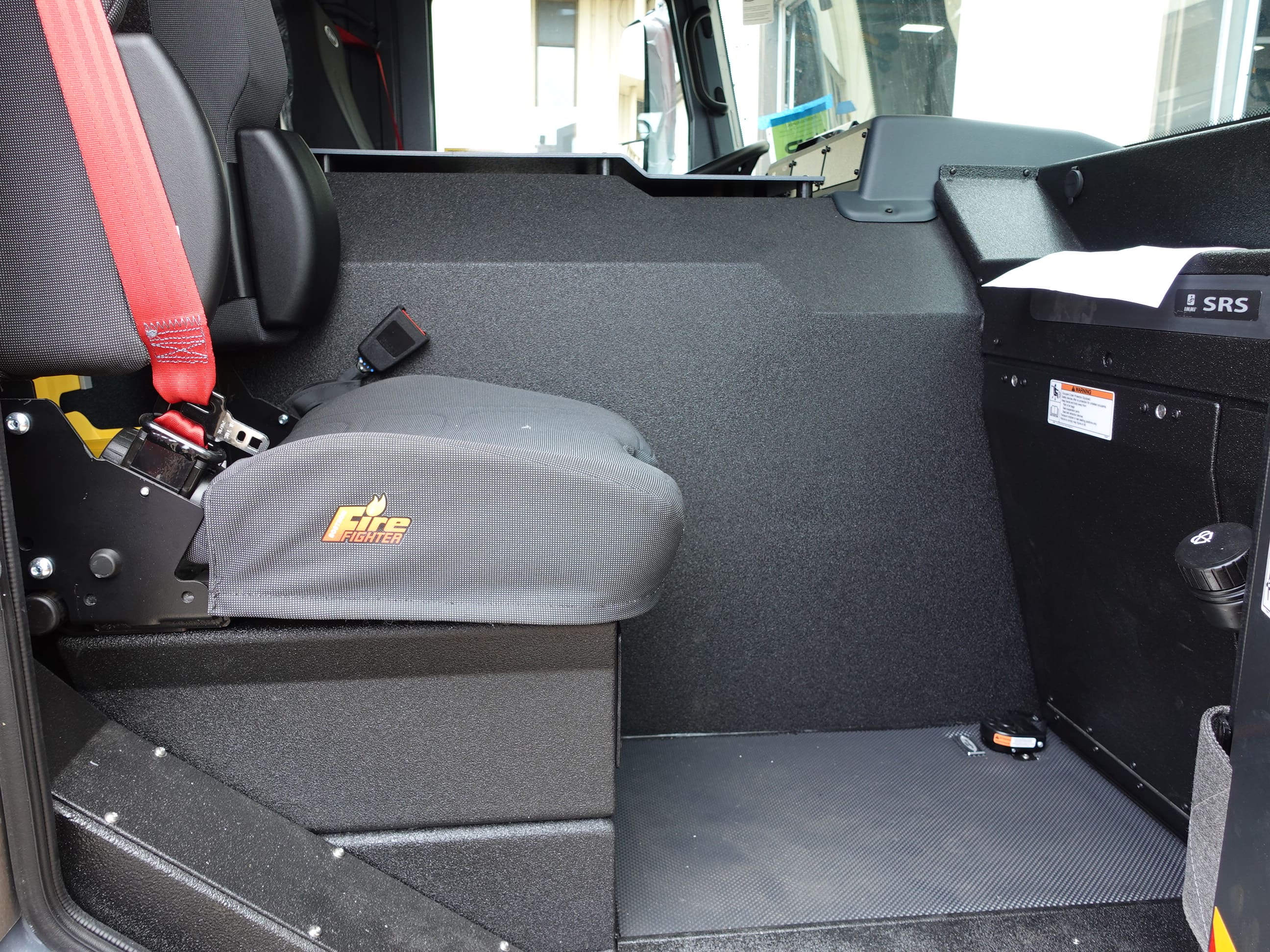

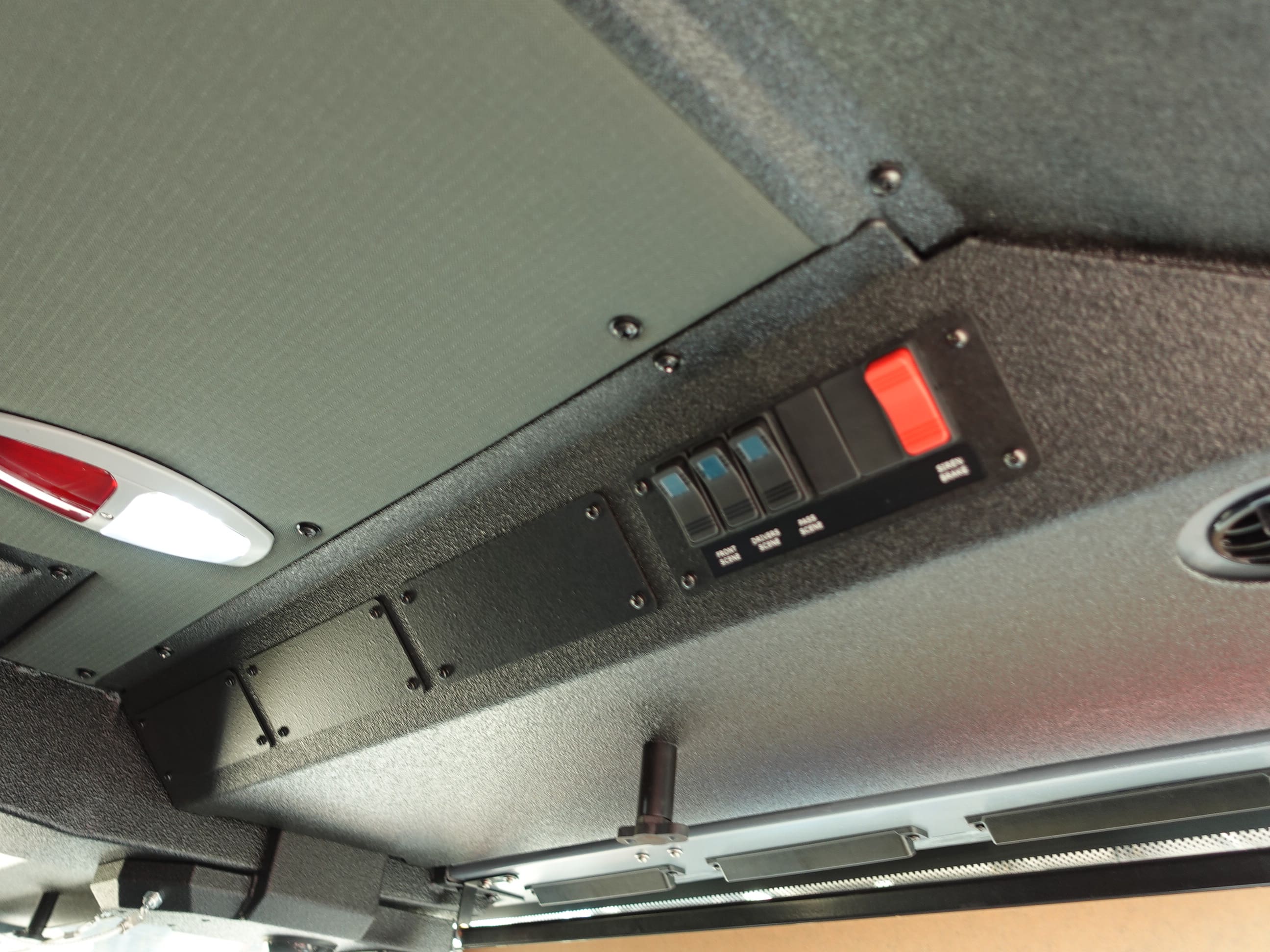

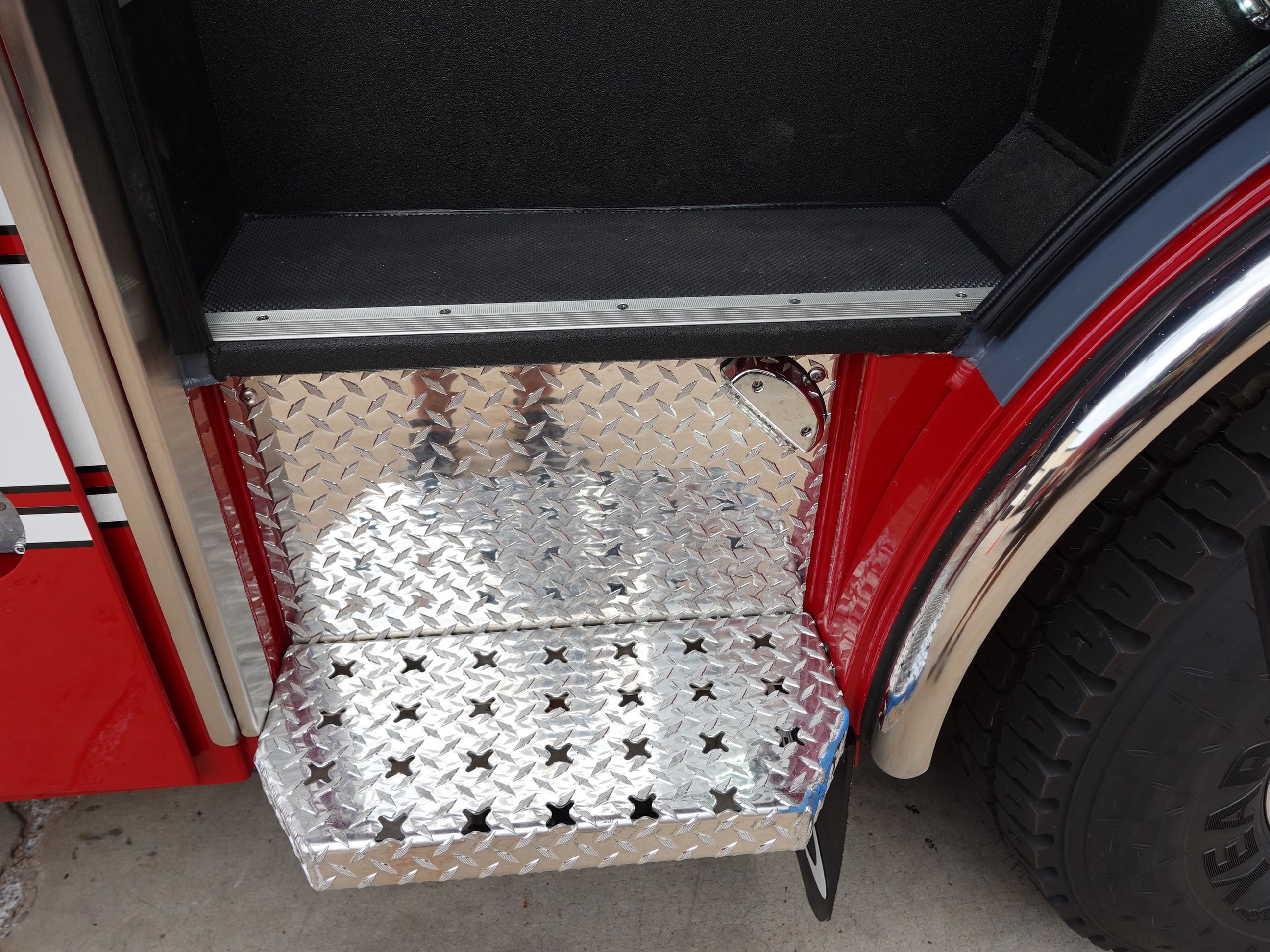

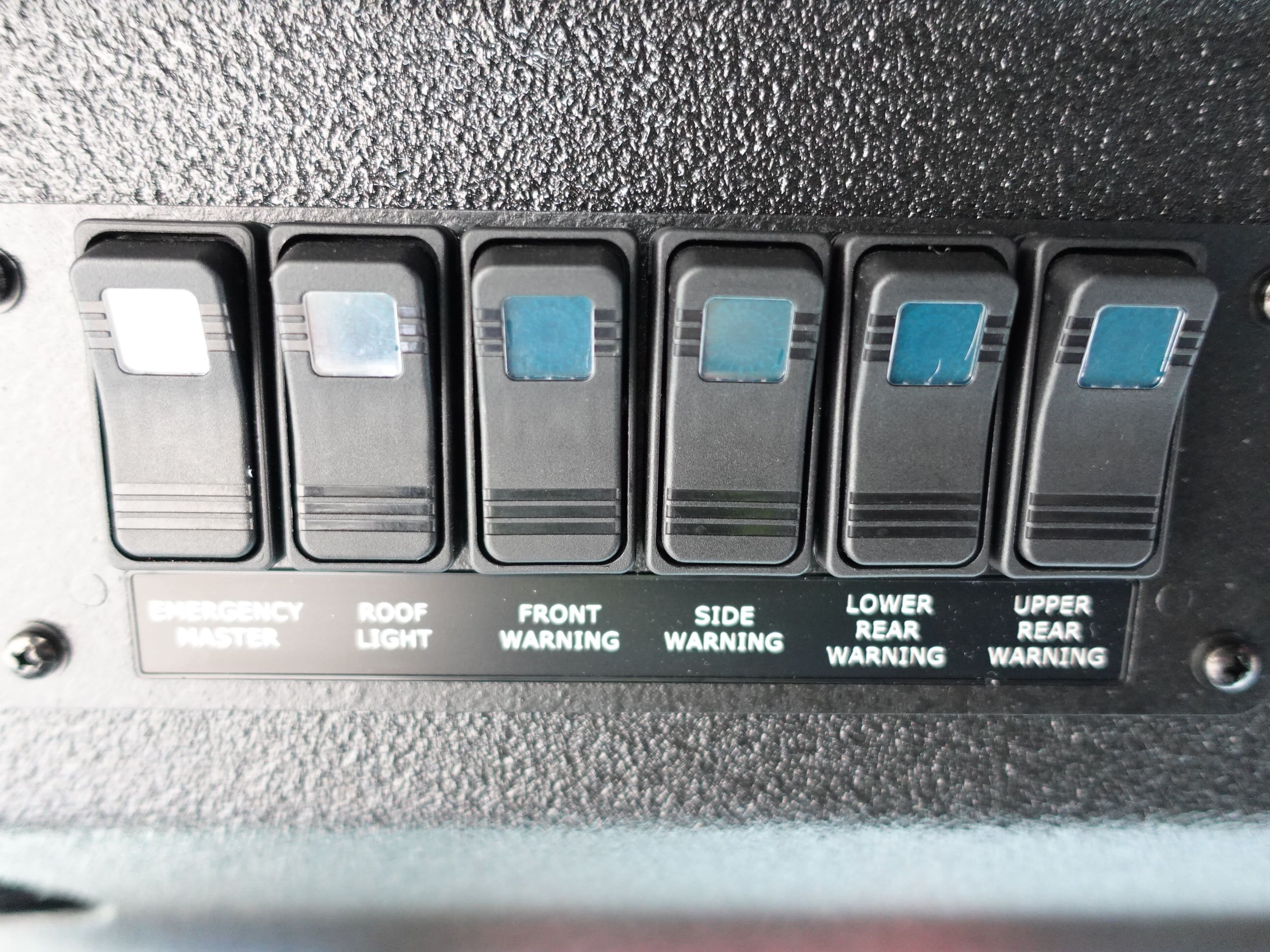

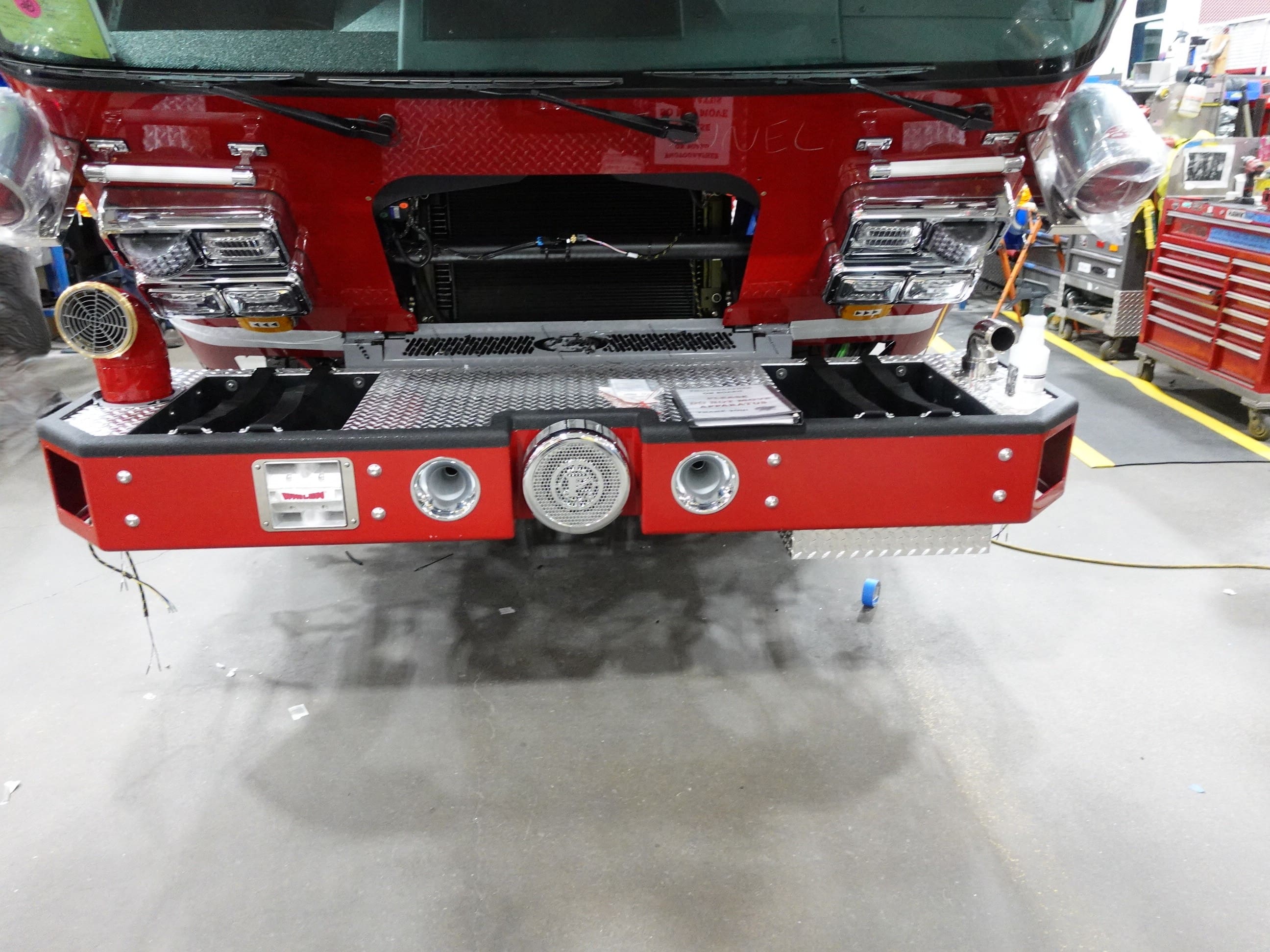

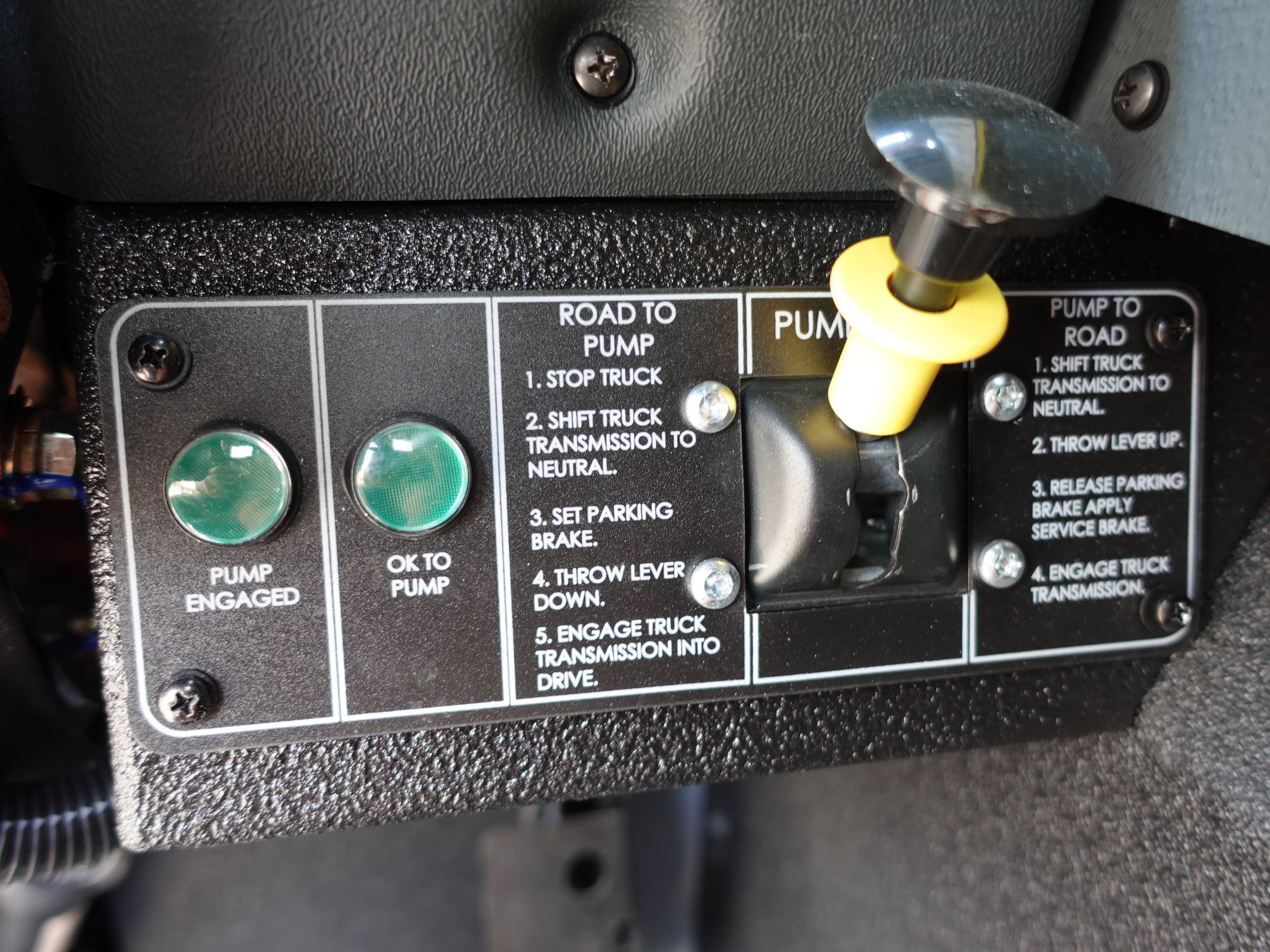

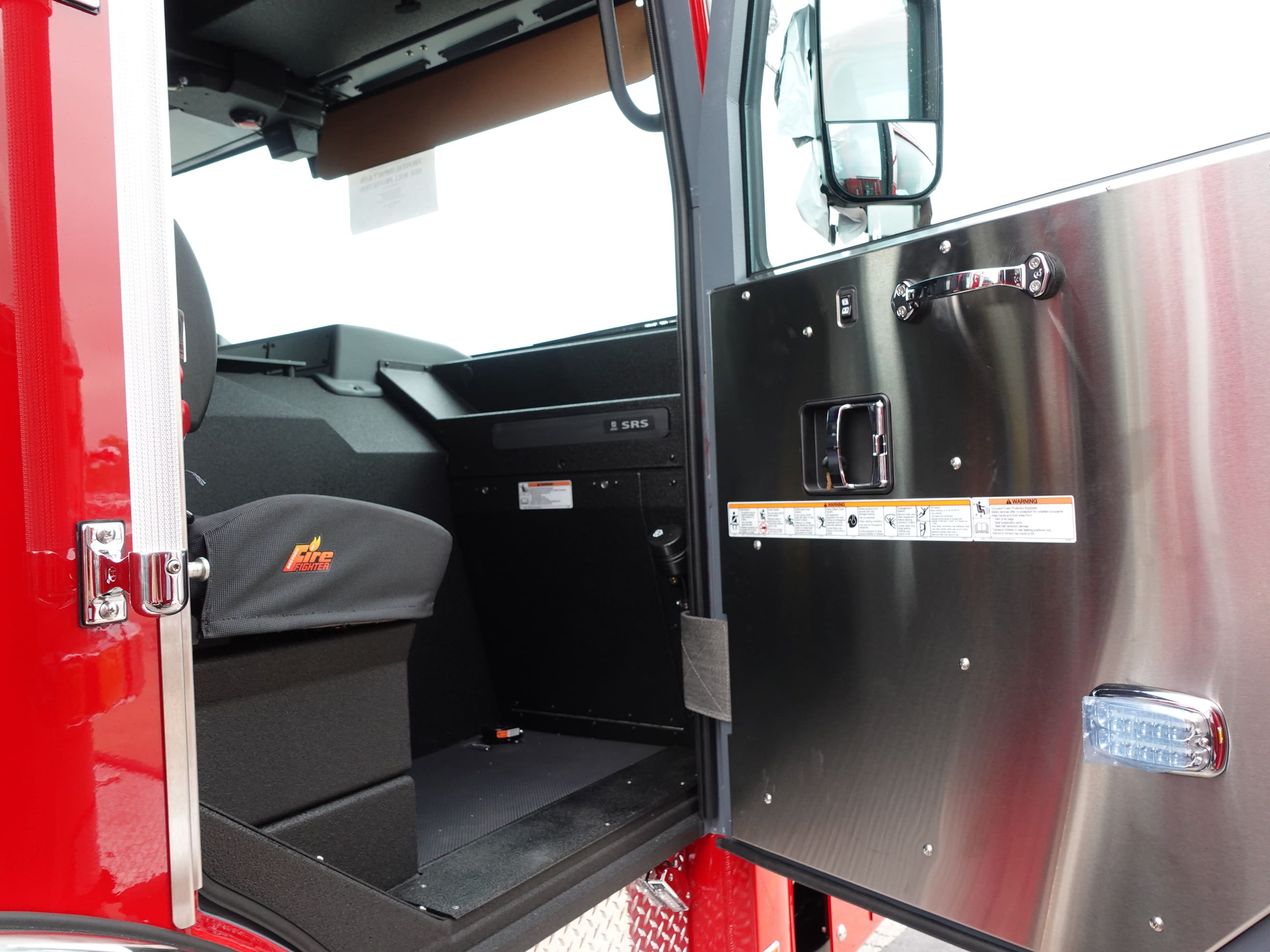

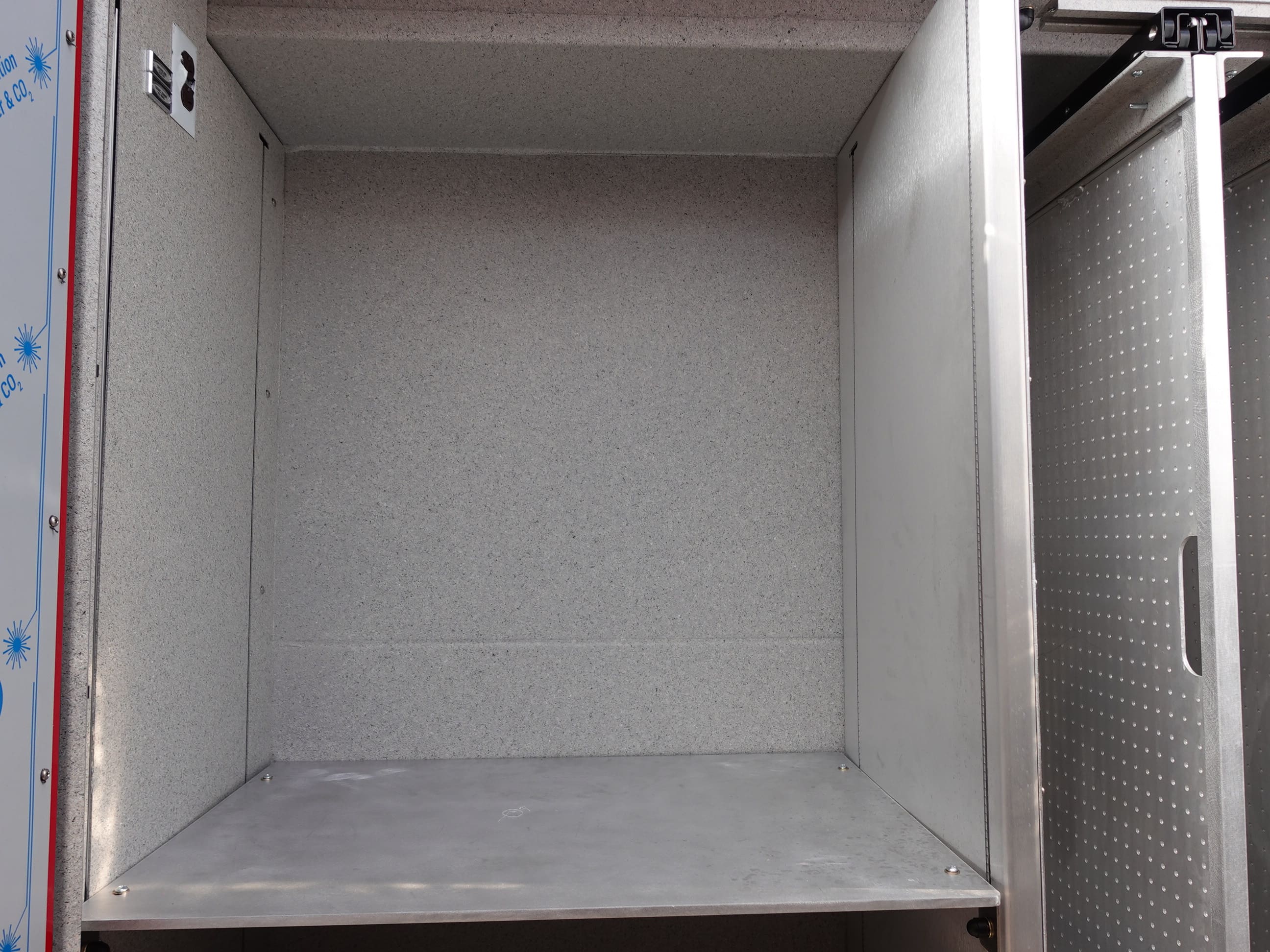

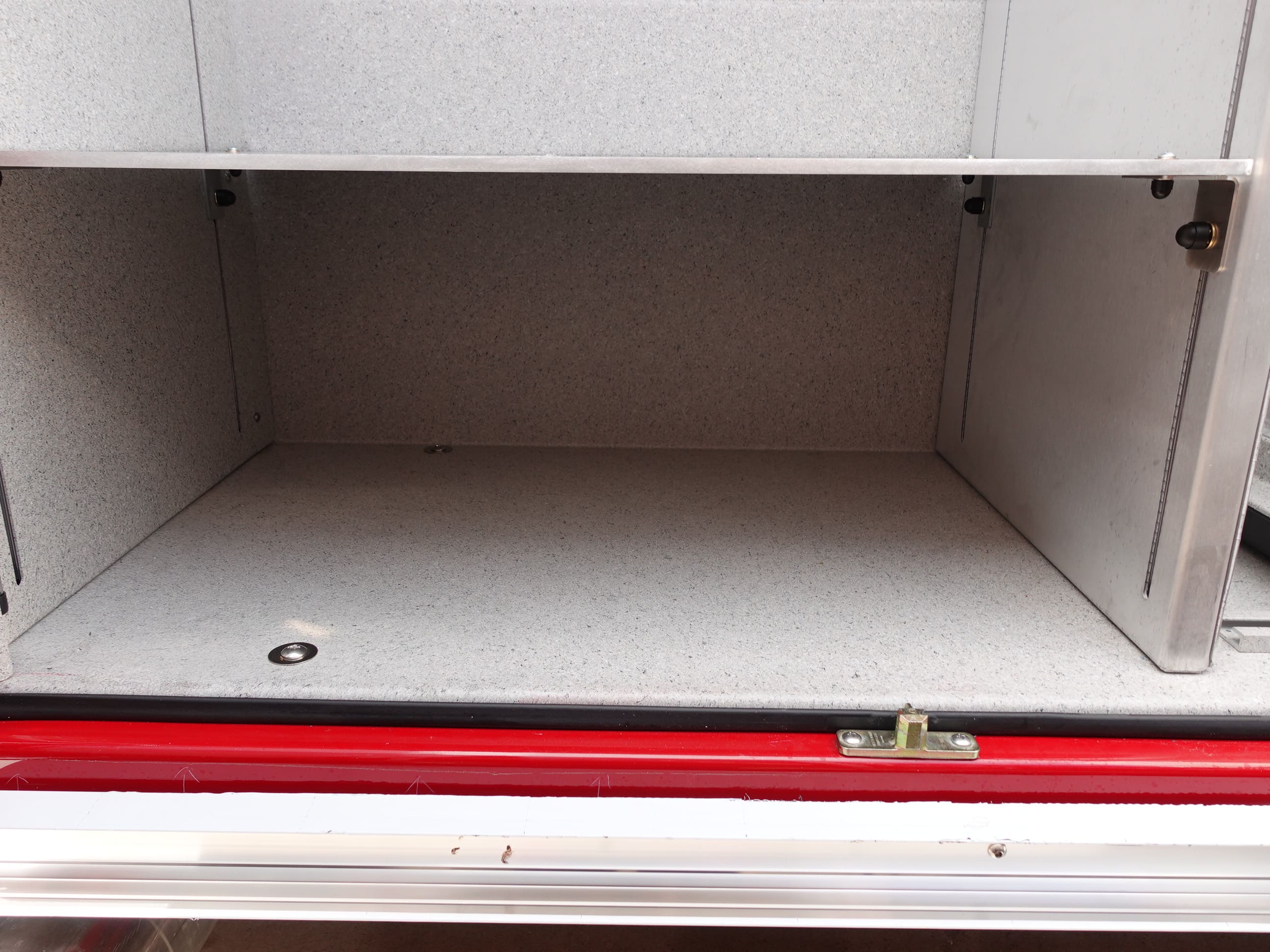

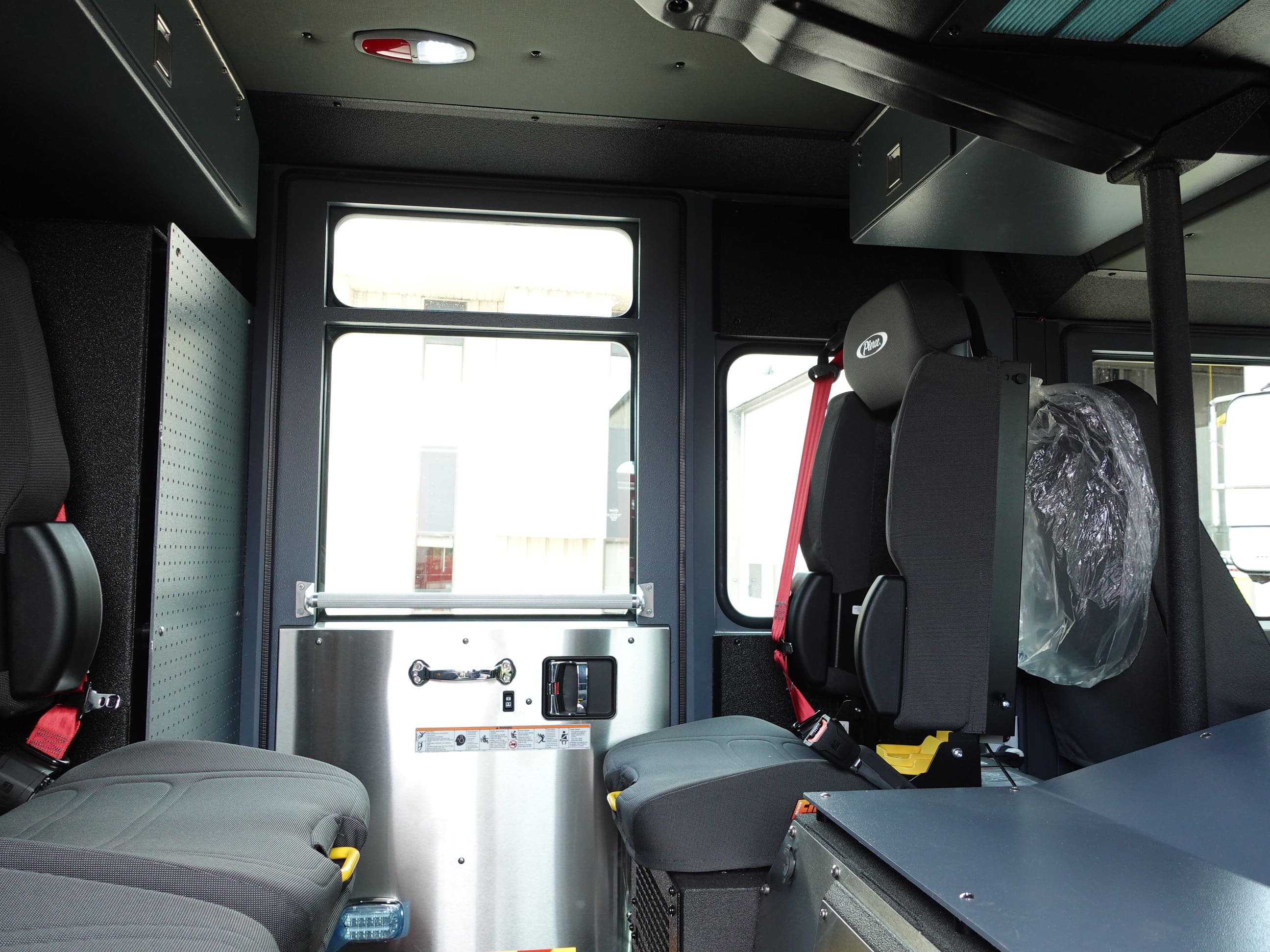

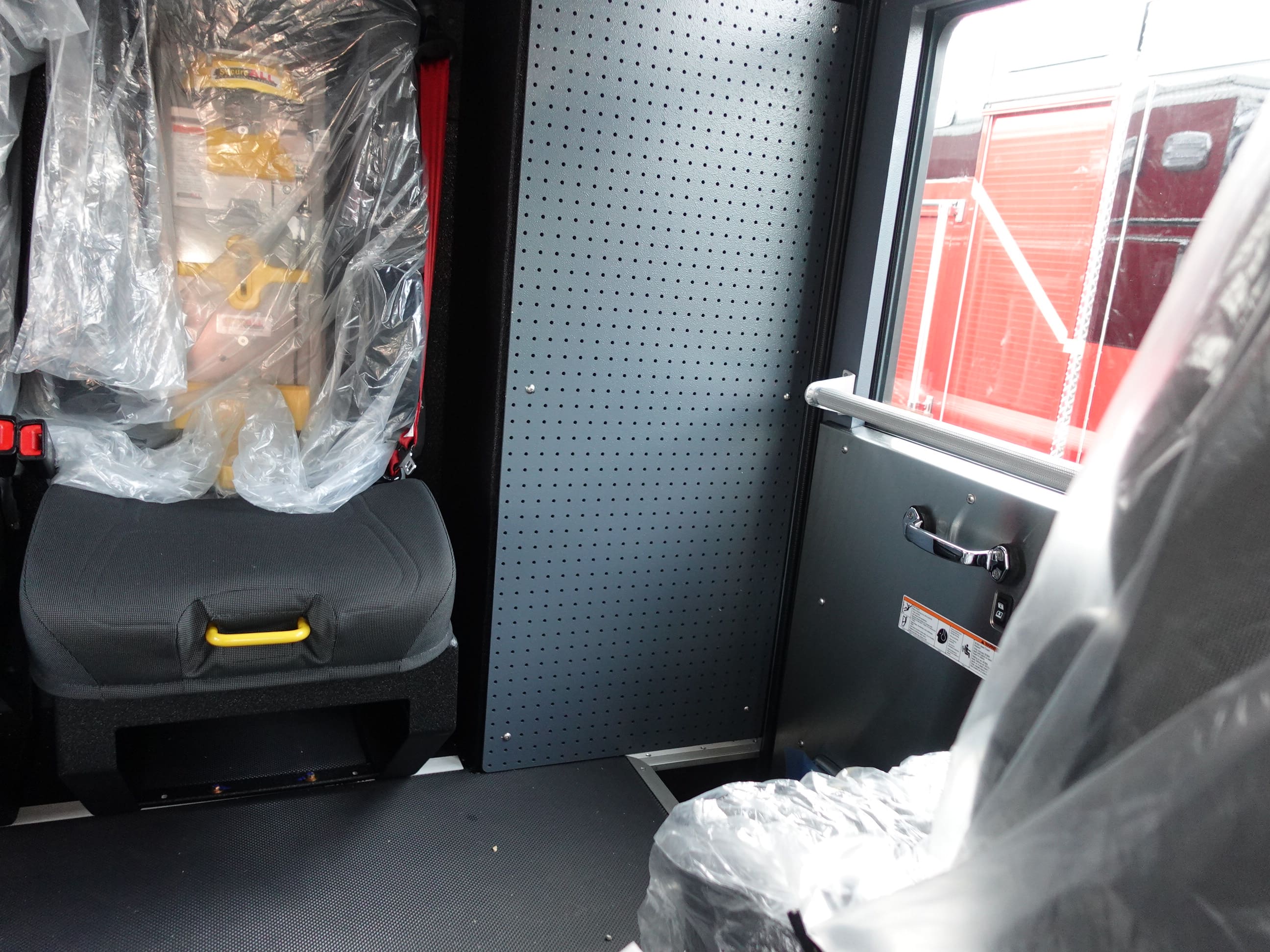

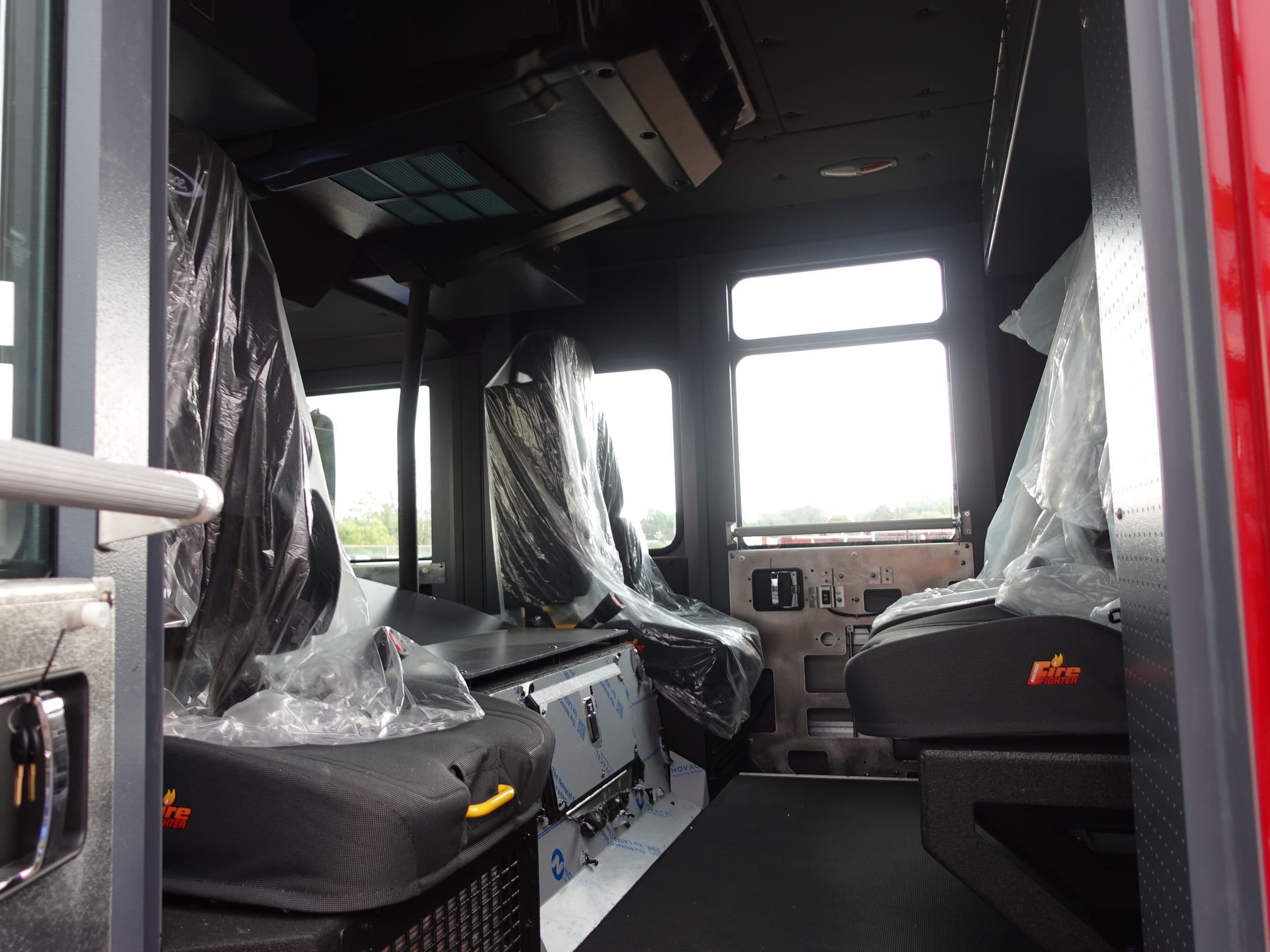

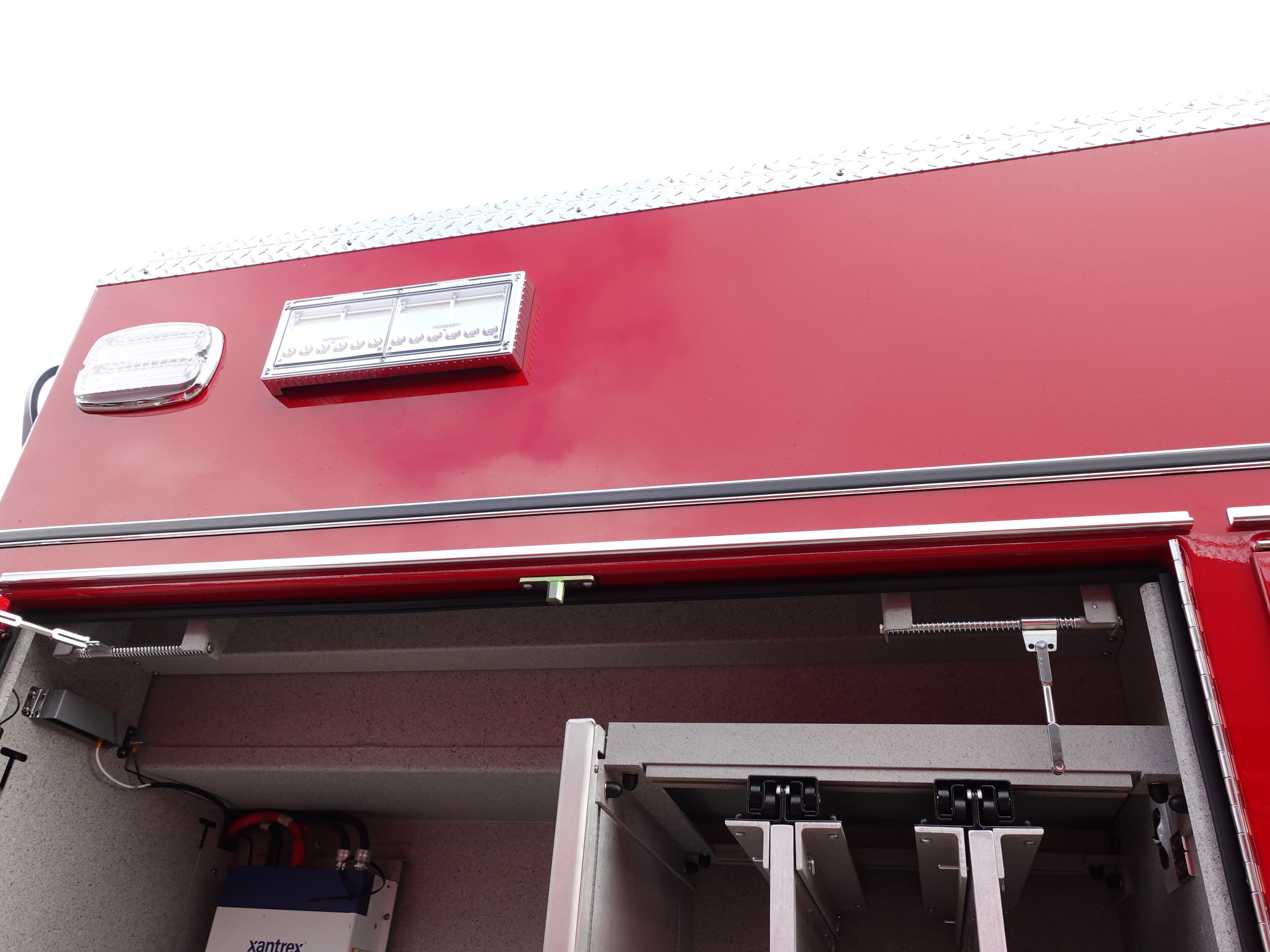

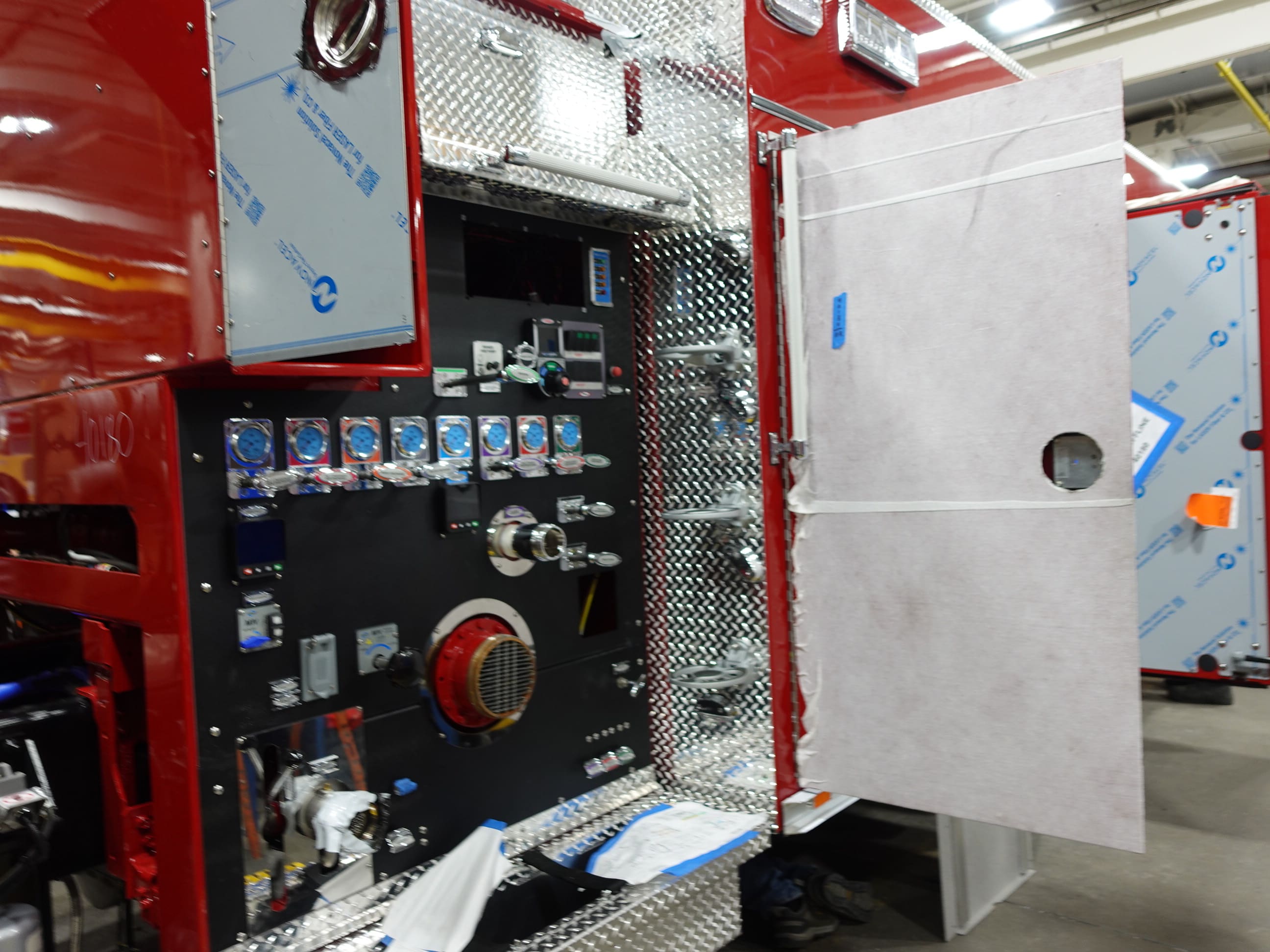

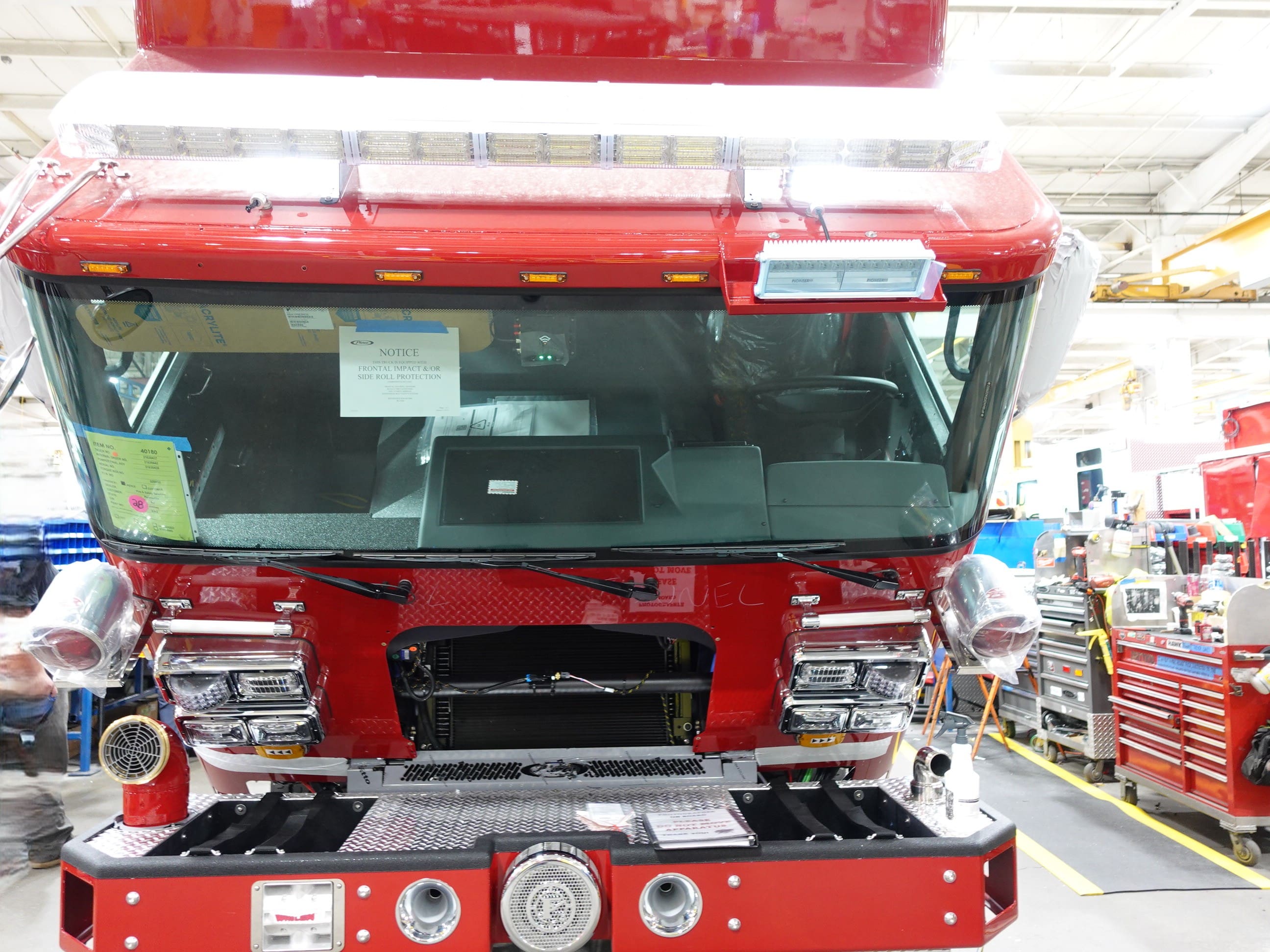

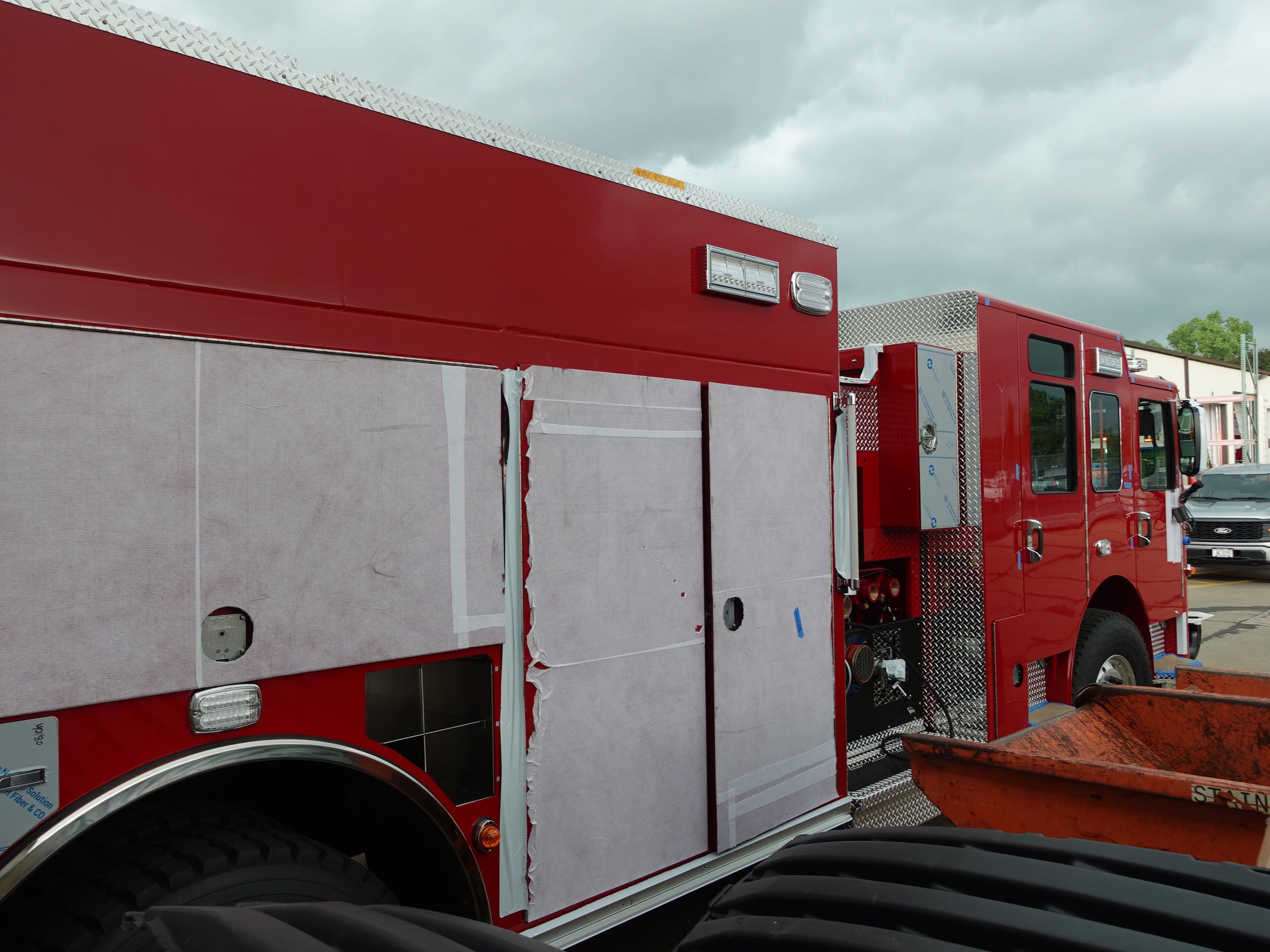

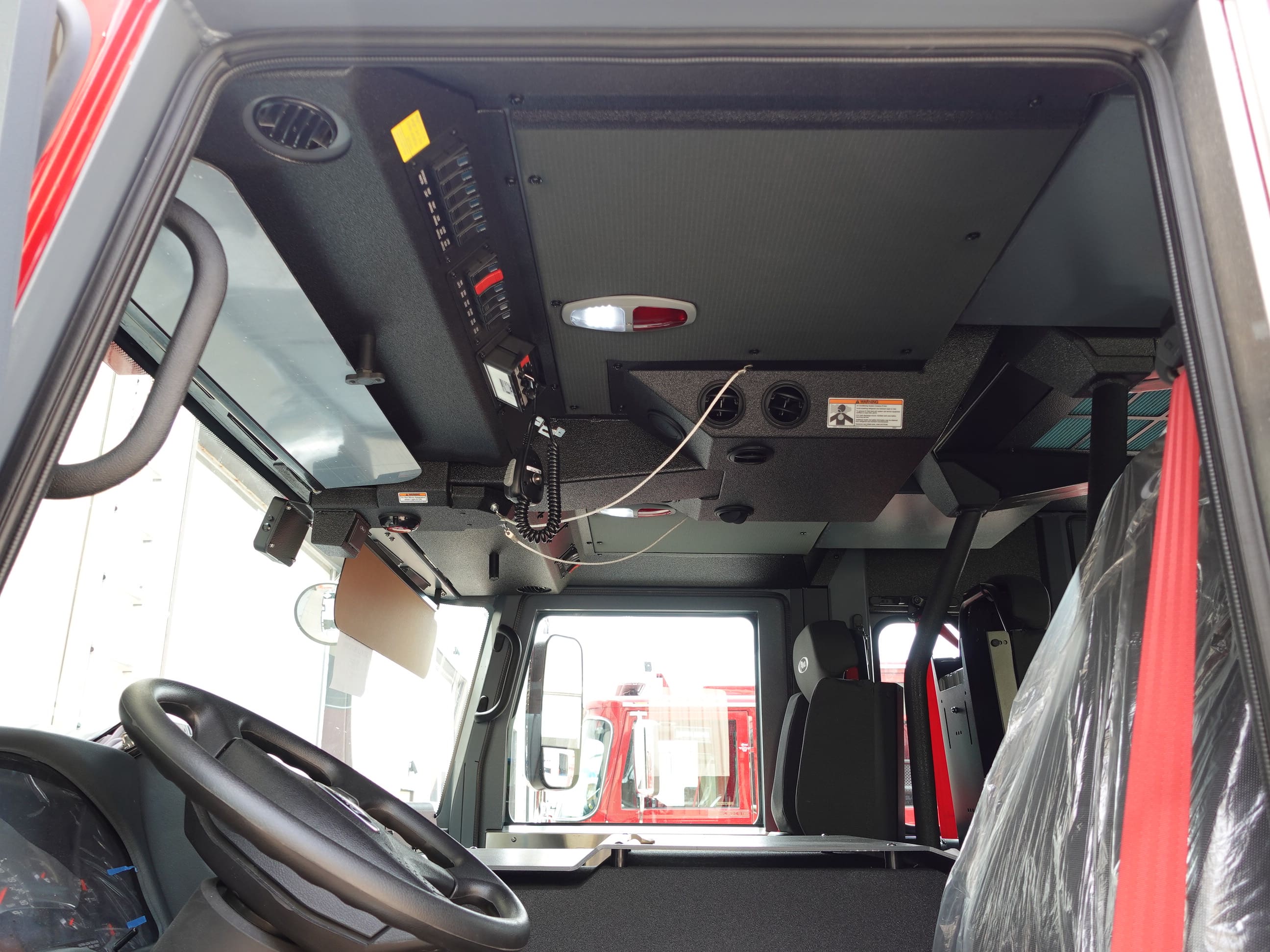

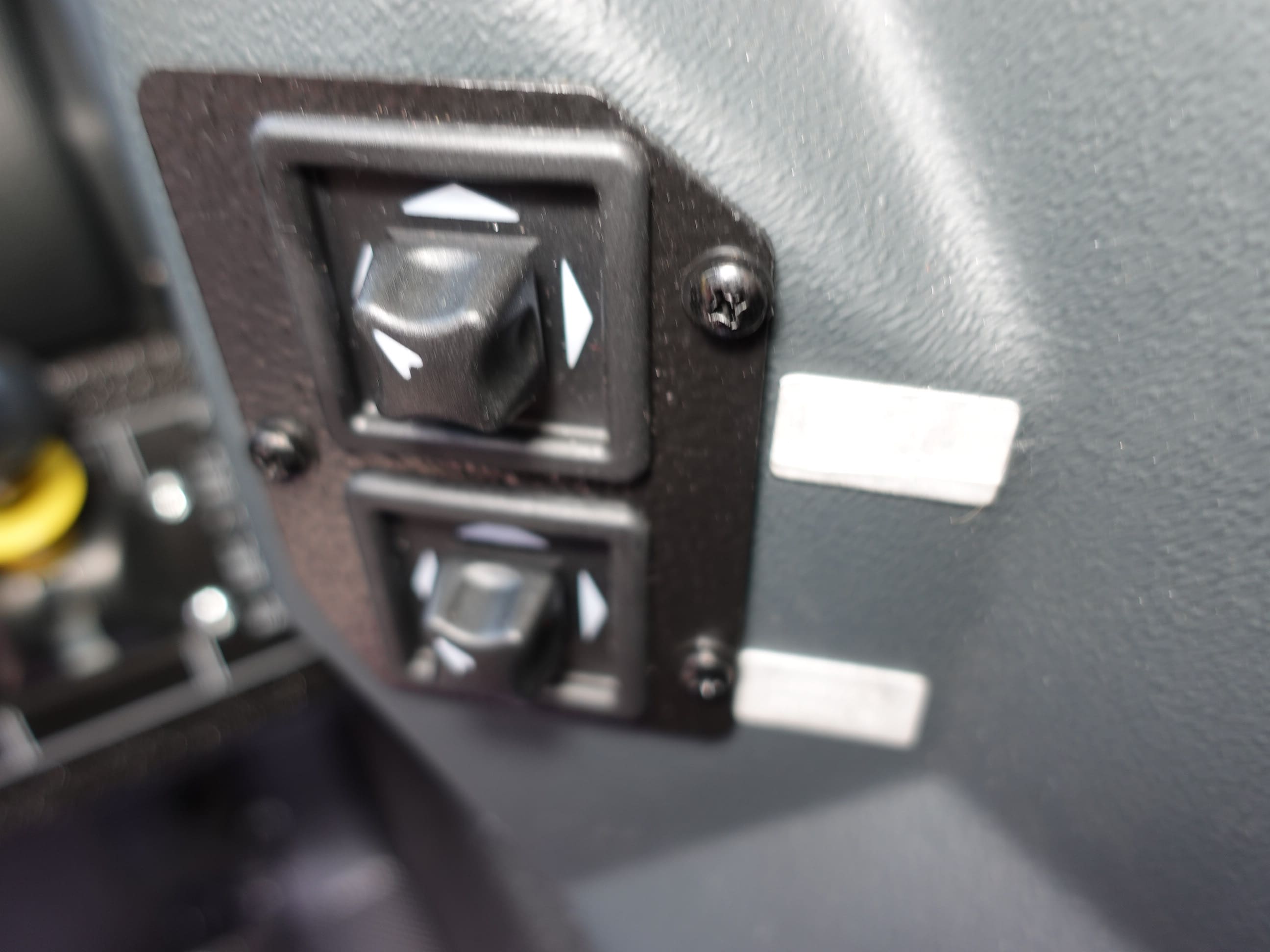

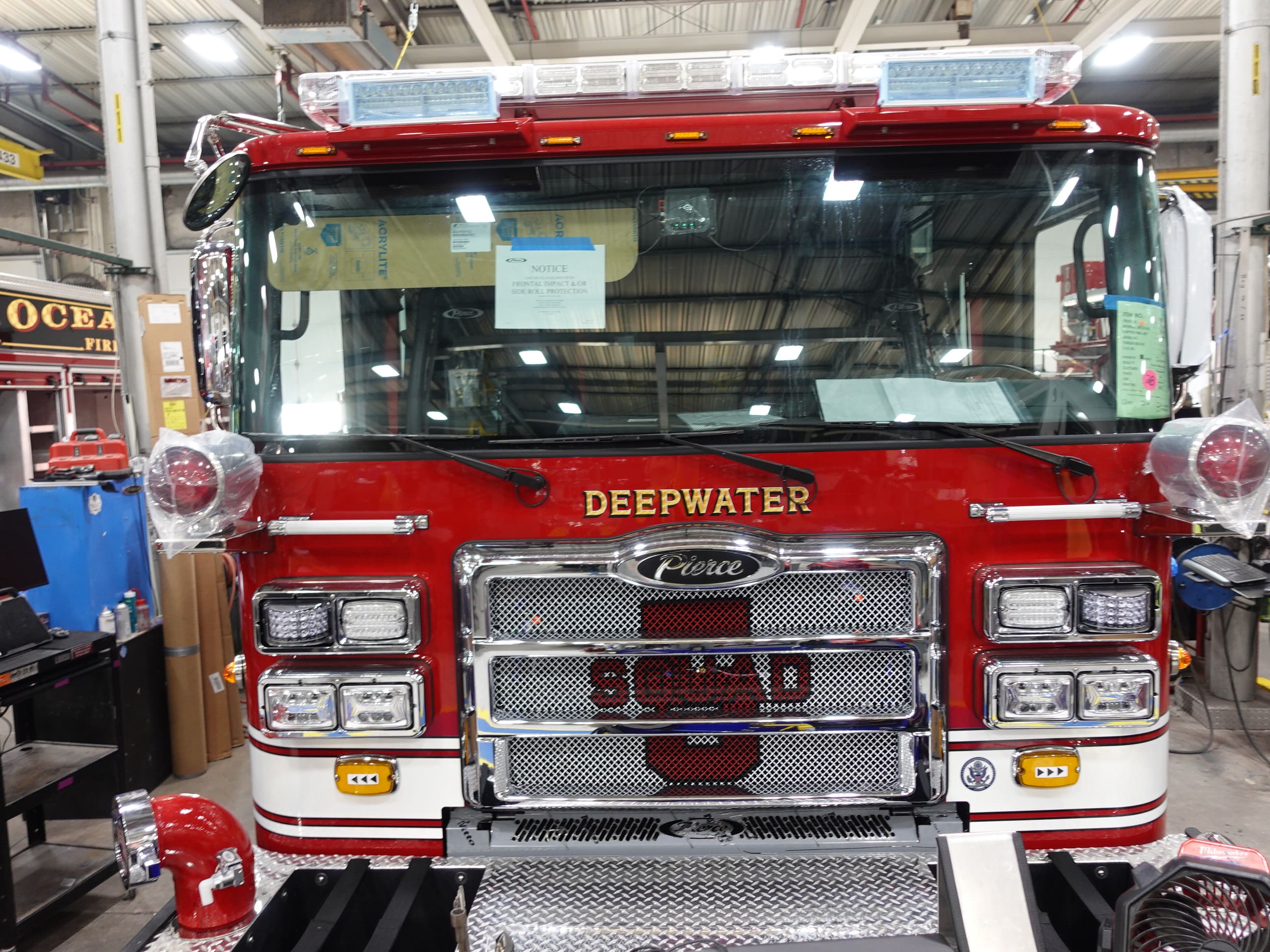

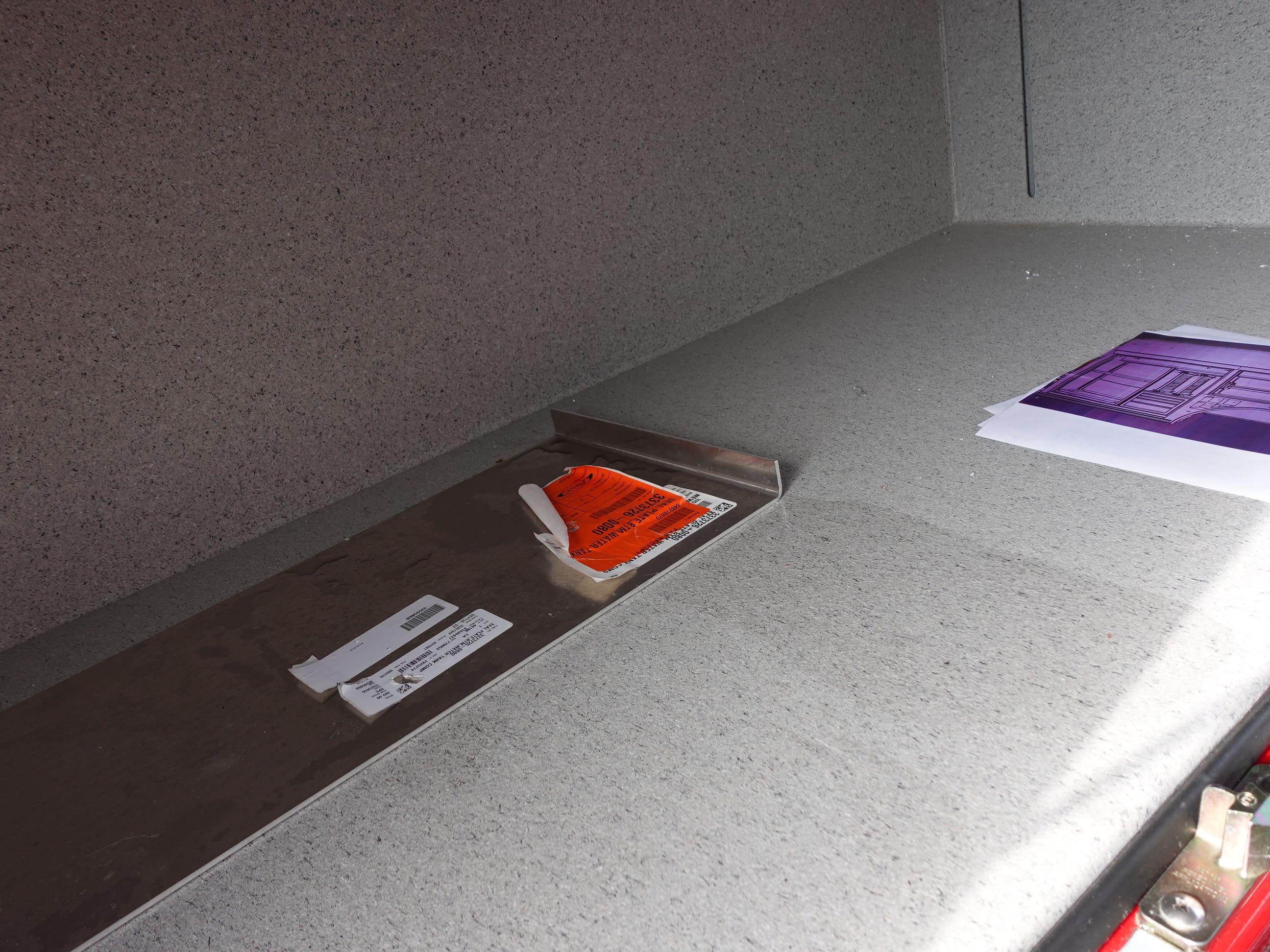

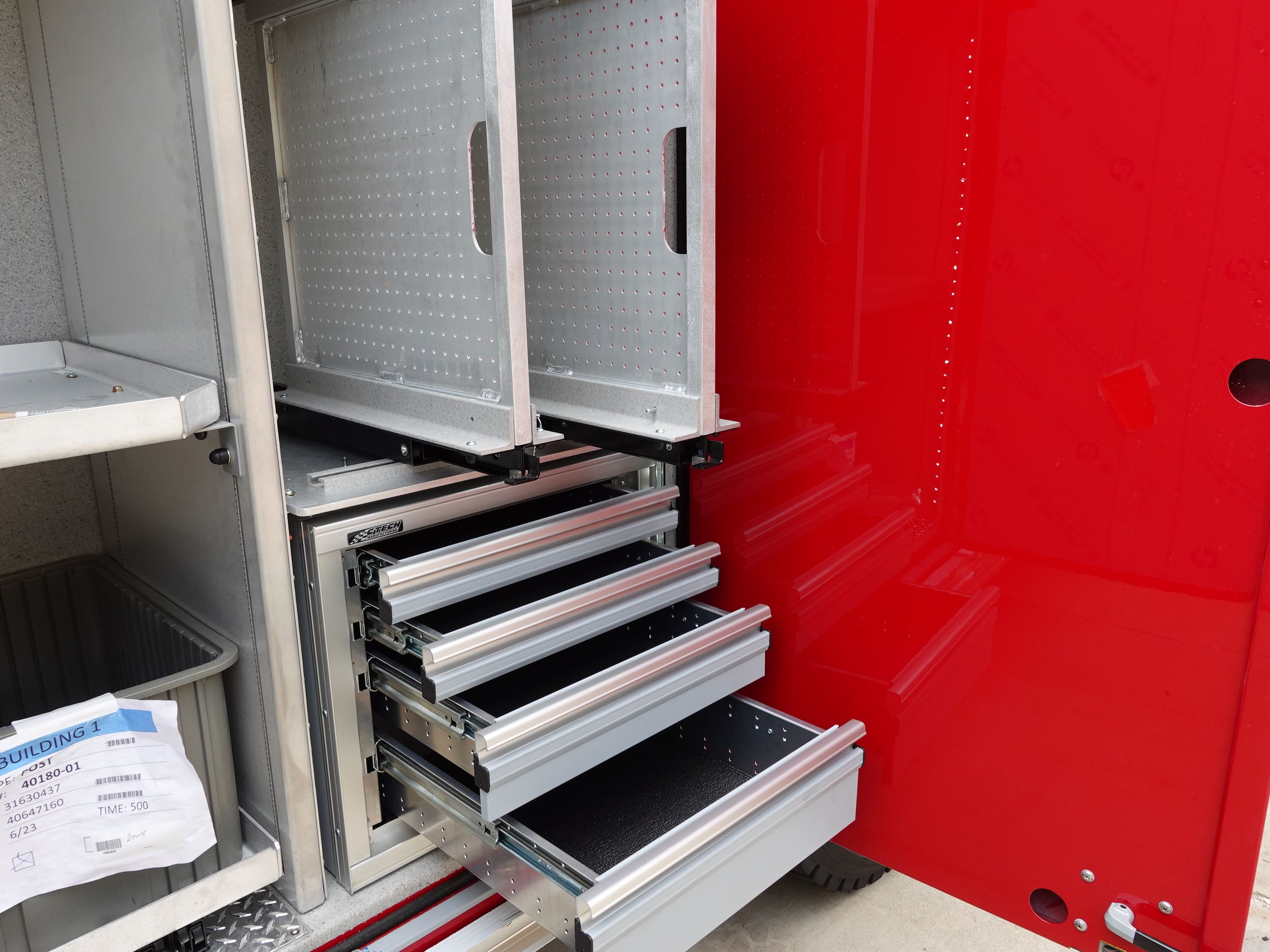

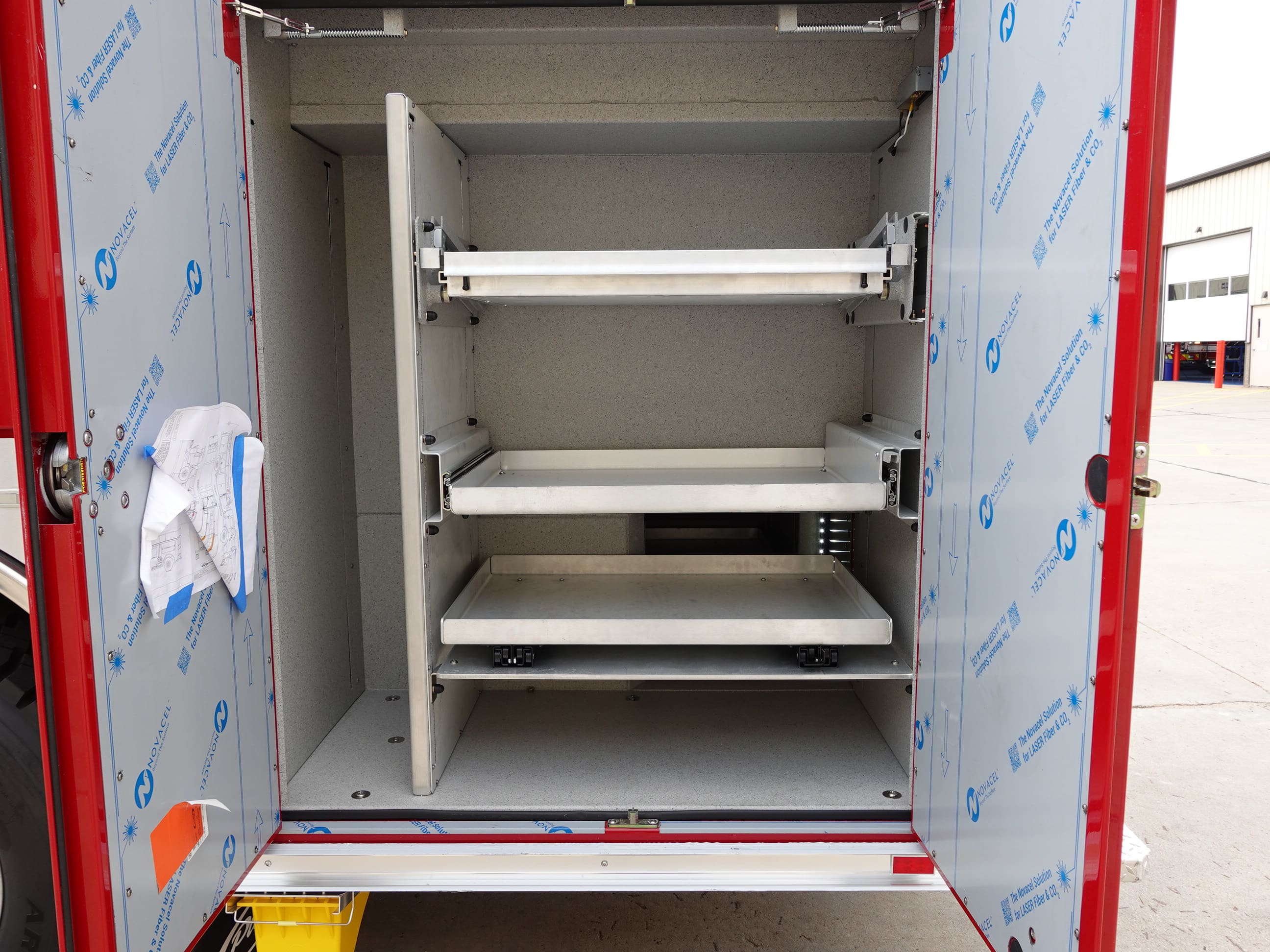

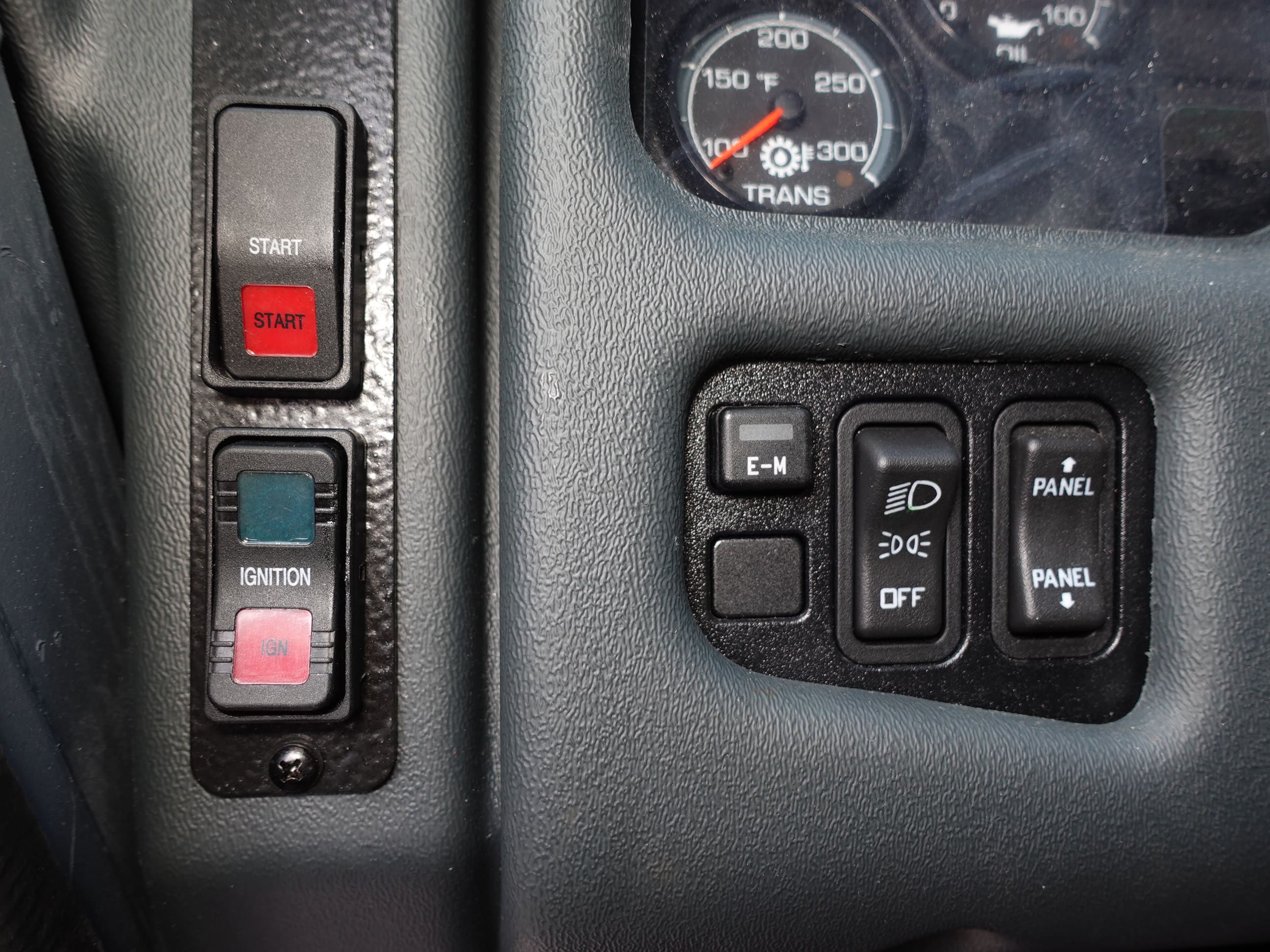

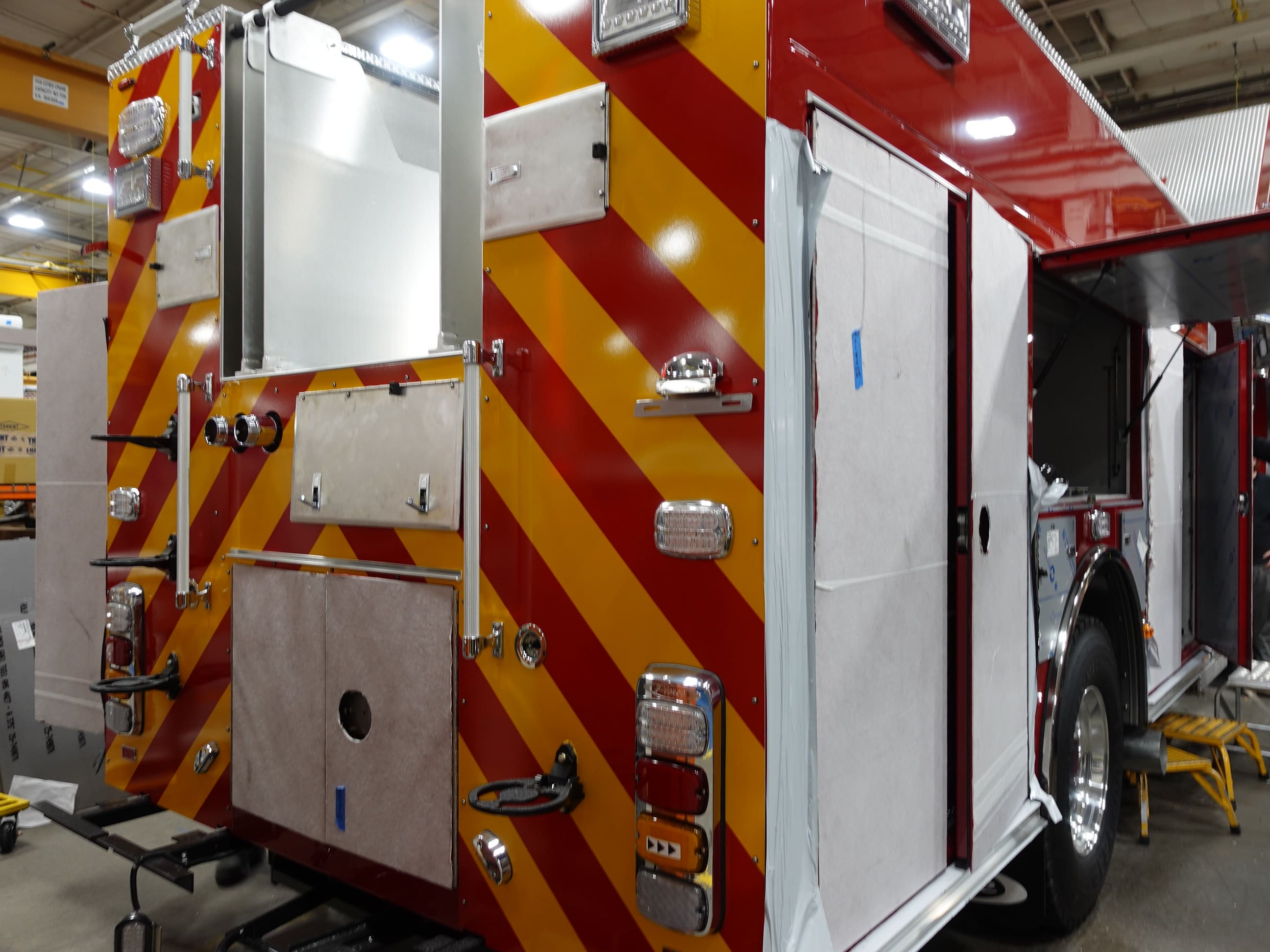

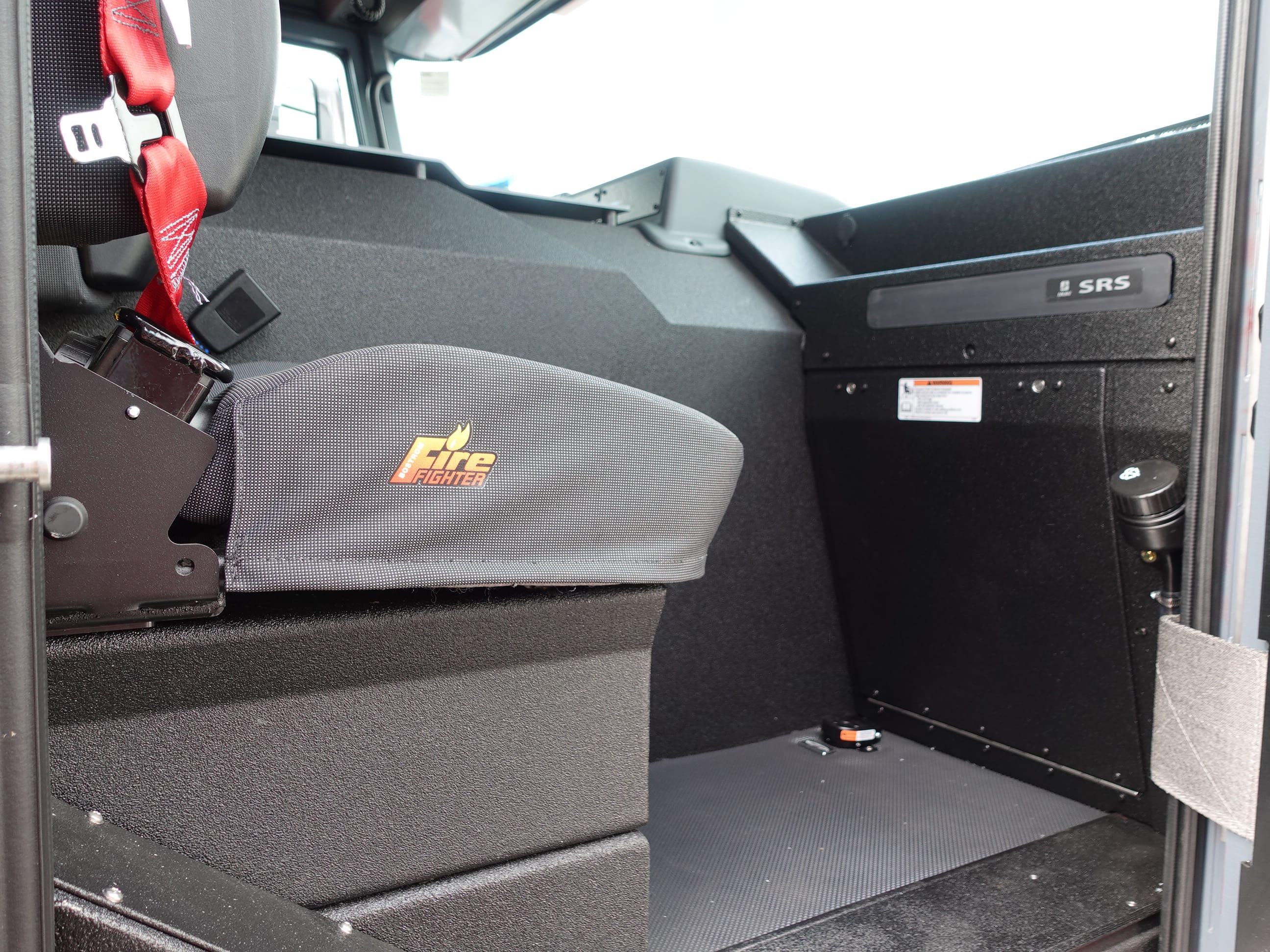

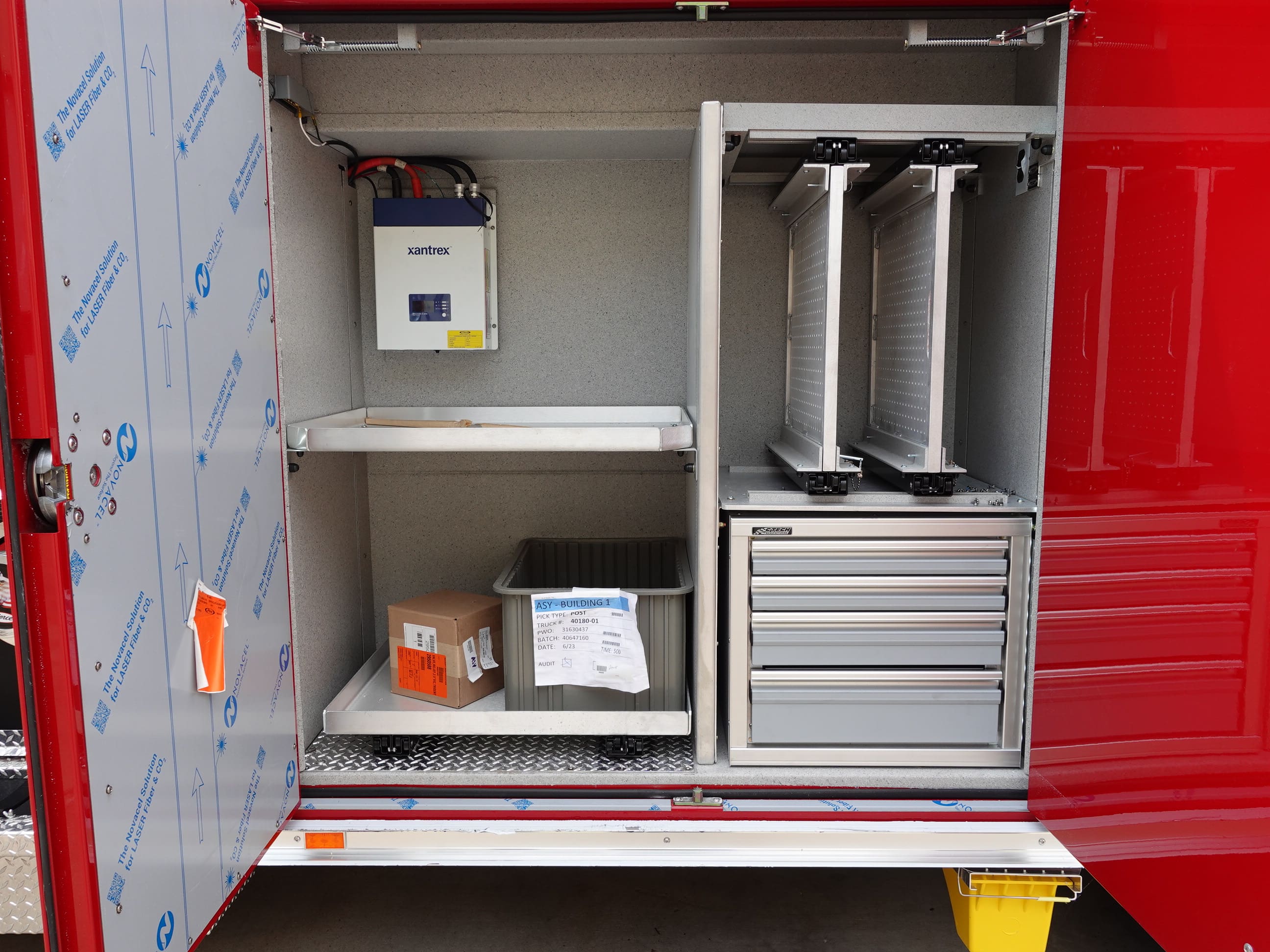

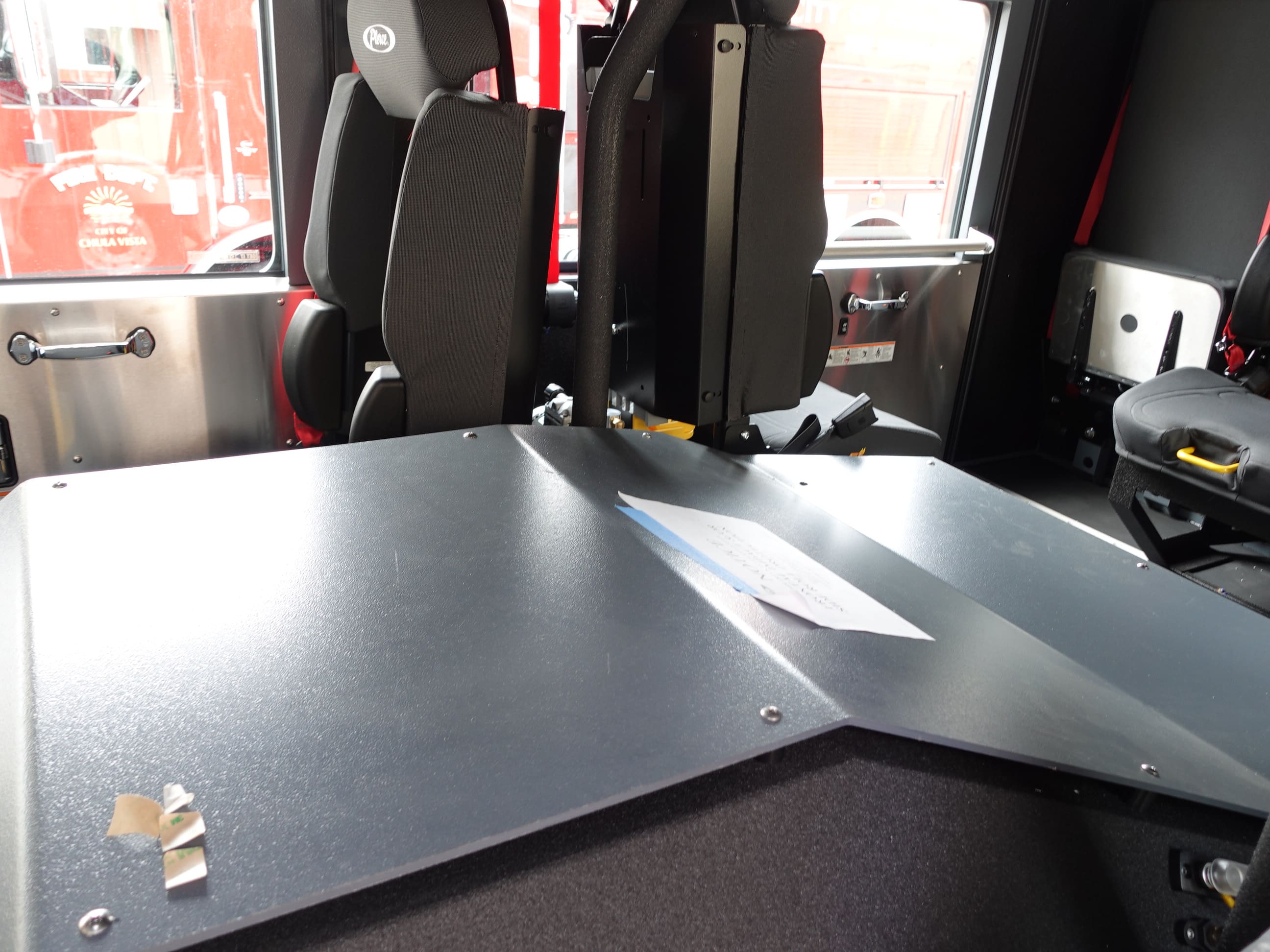

In this report, the apparatus was staged to continue through quality and graphics where any remaining content is applied. When finished it

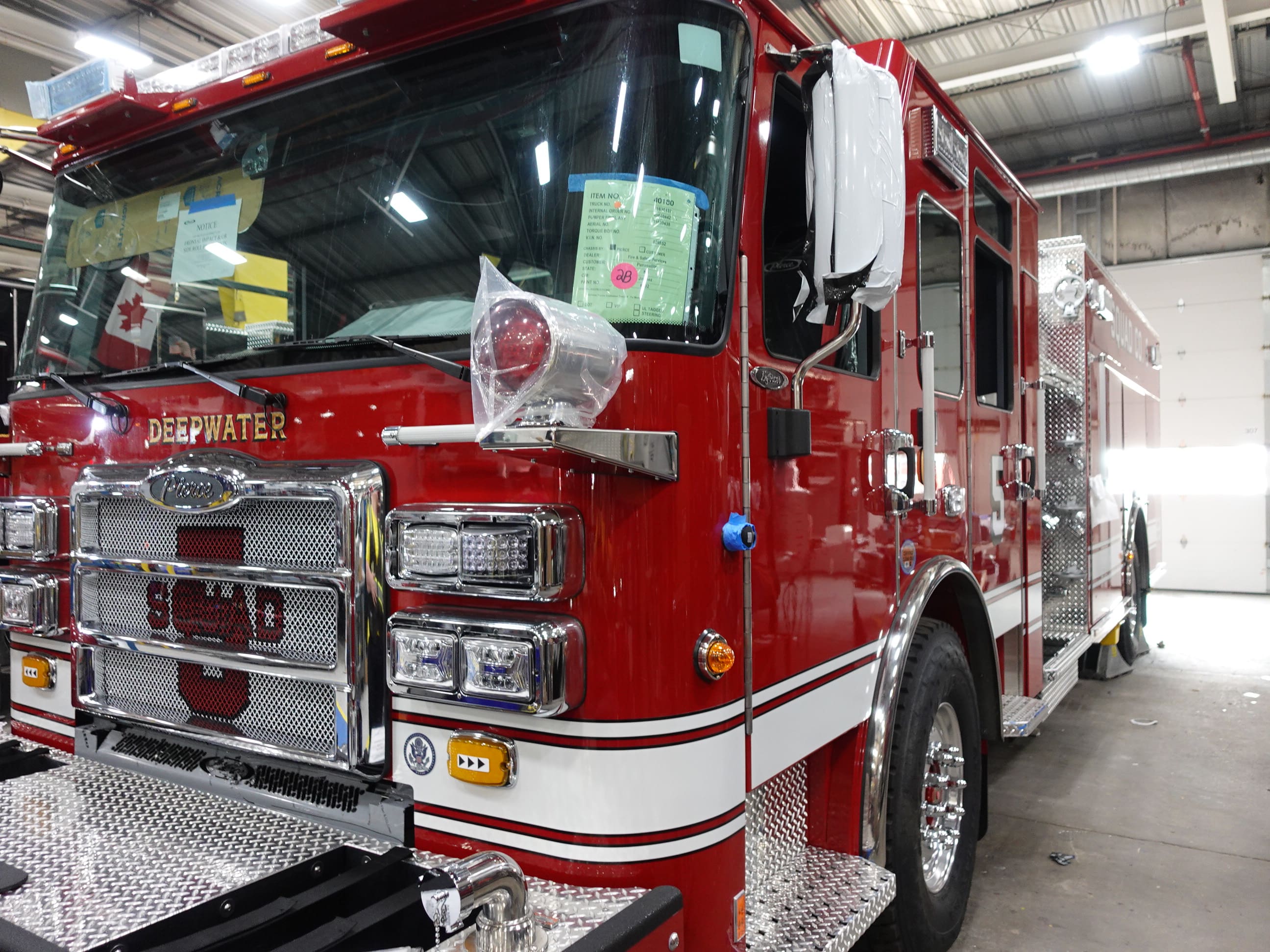

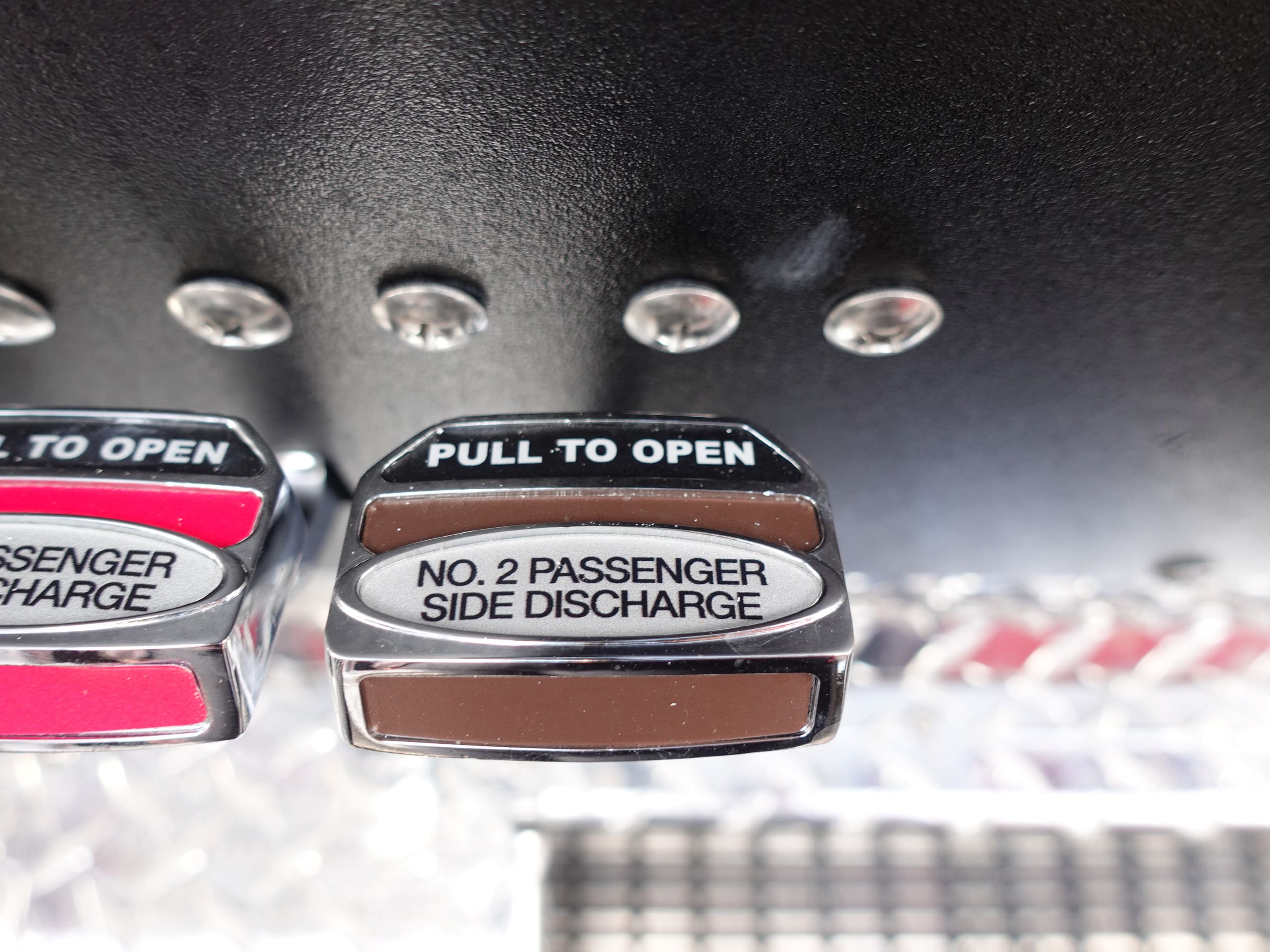

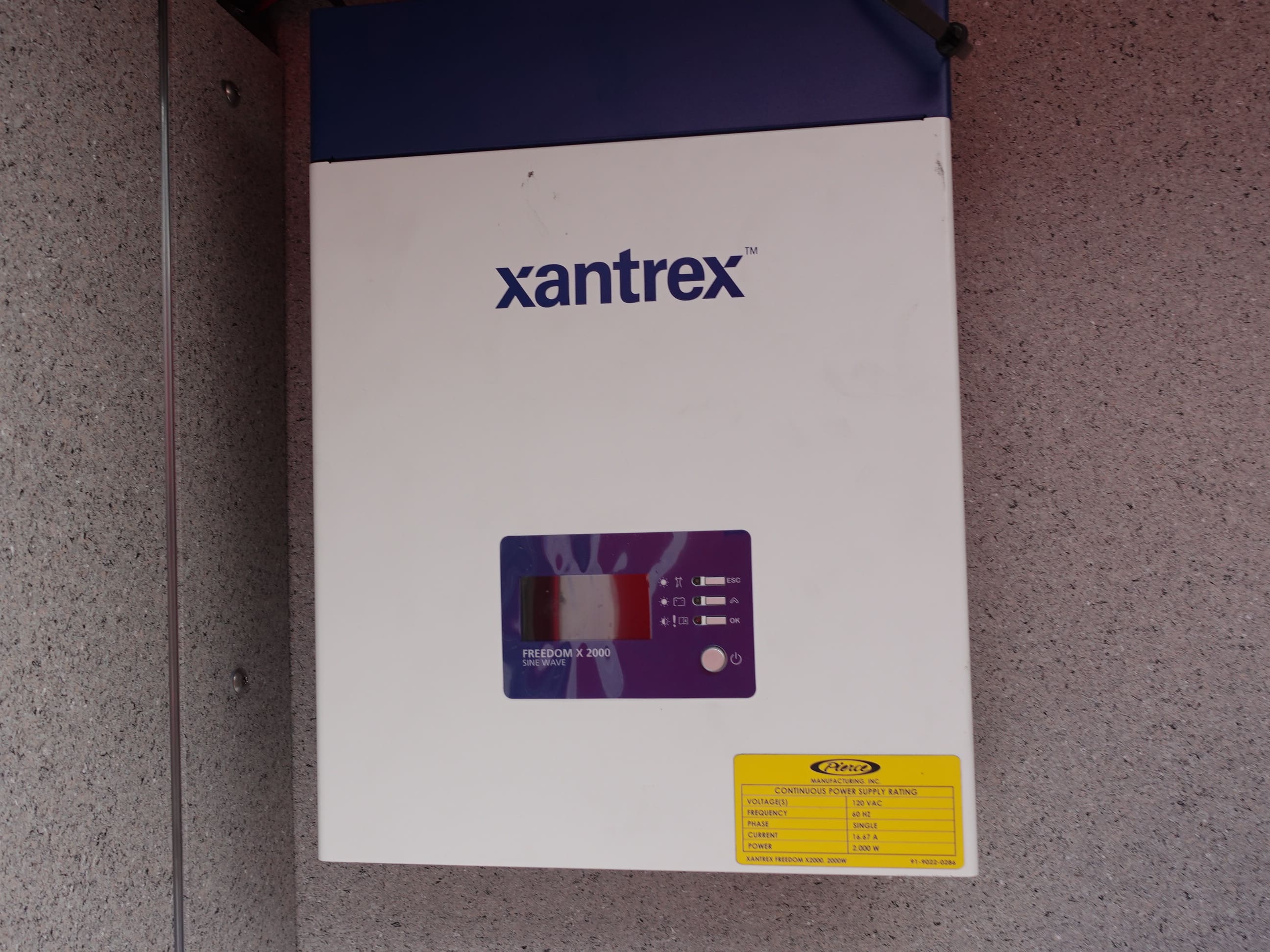

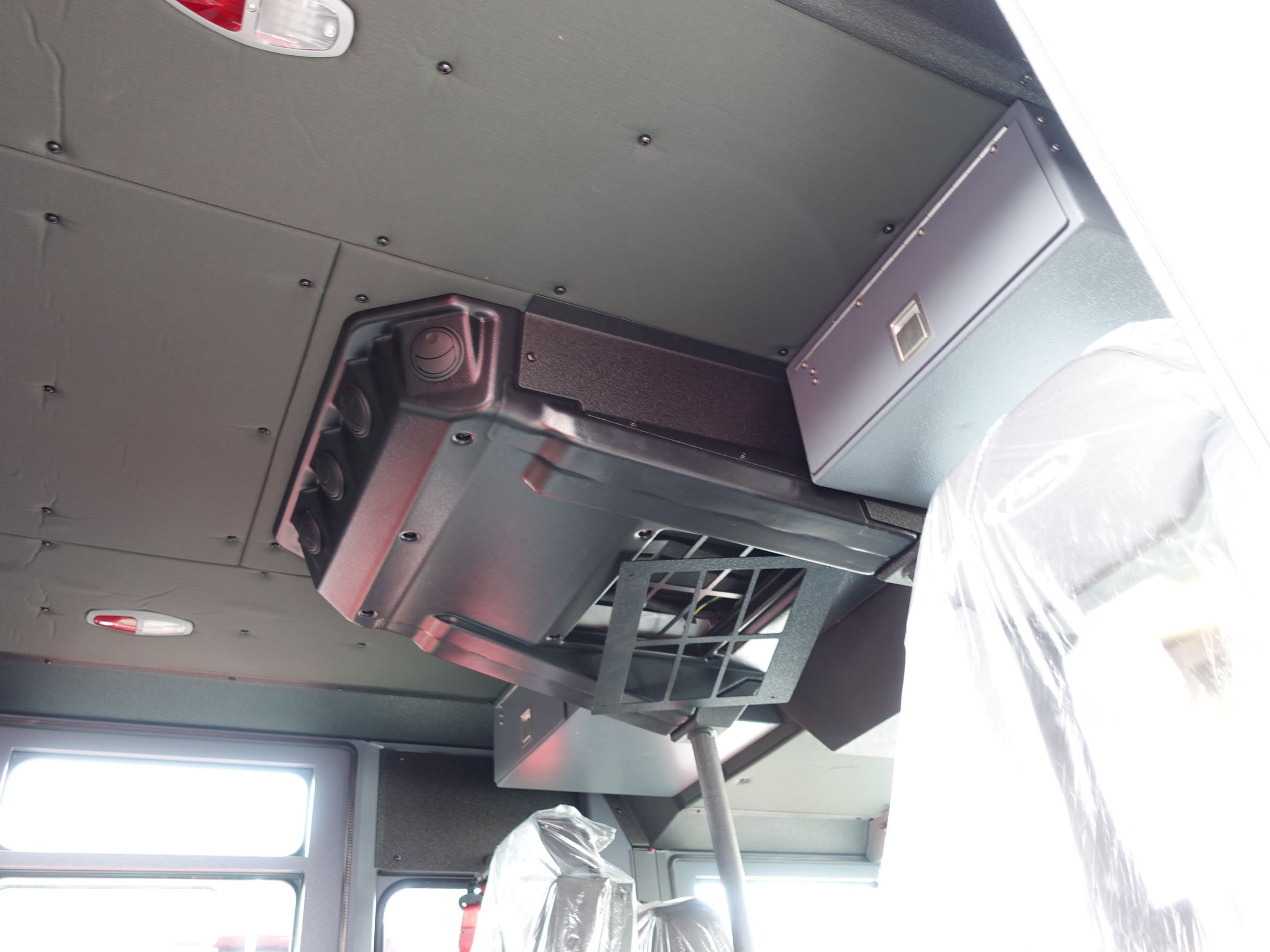

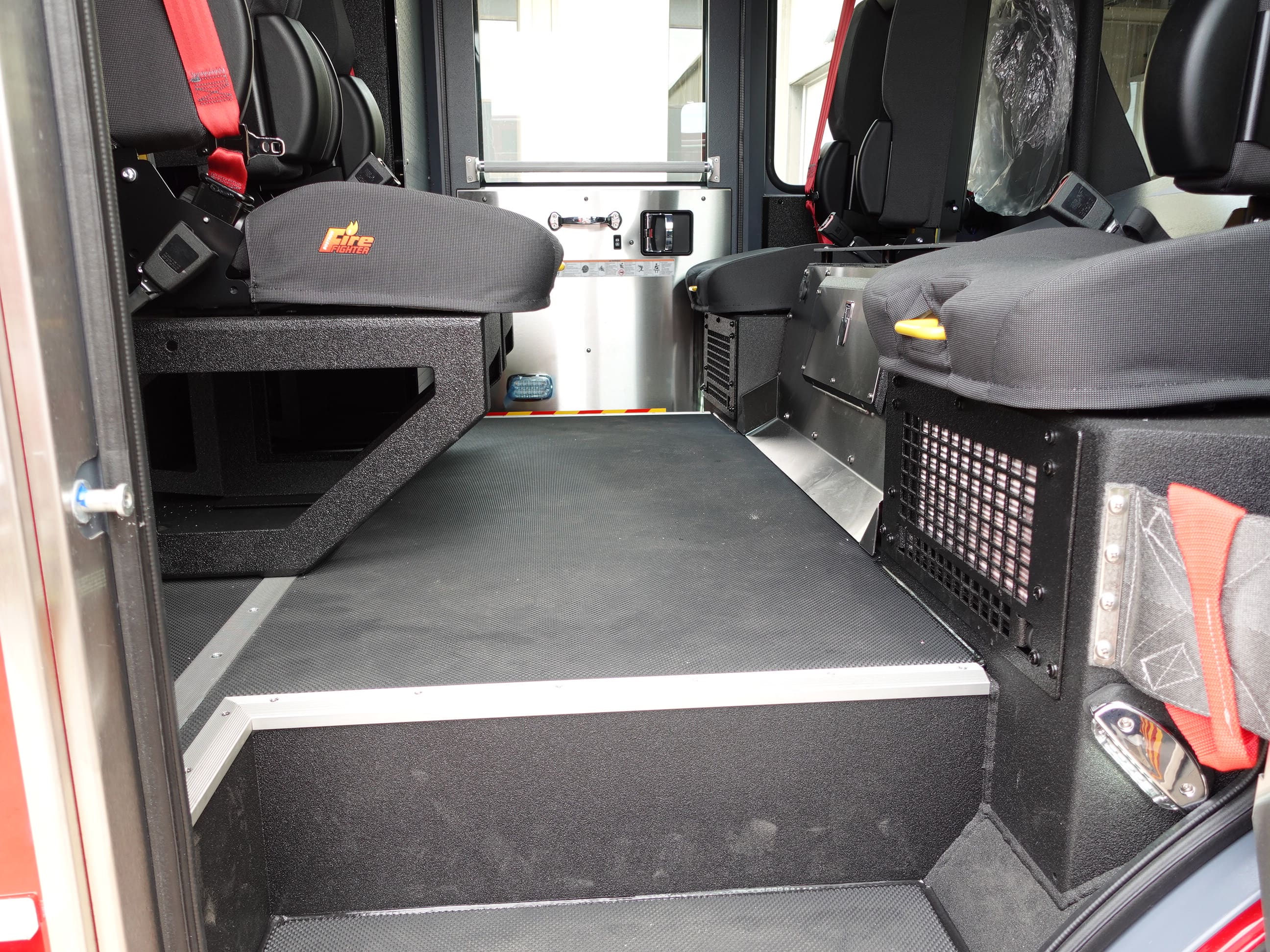

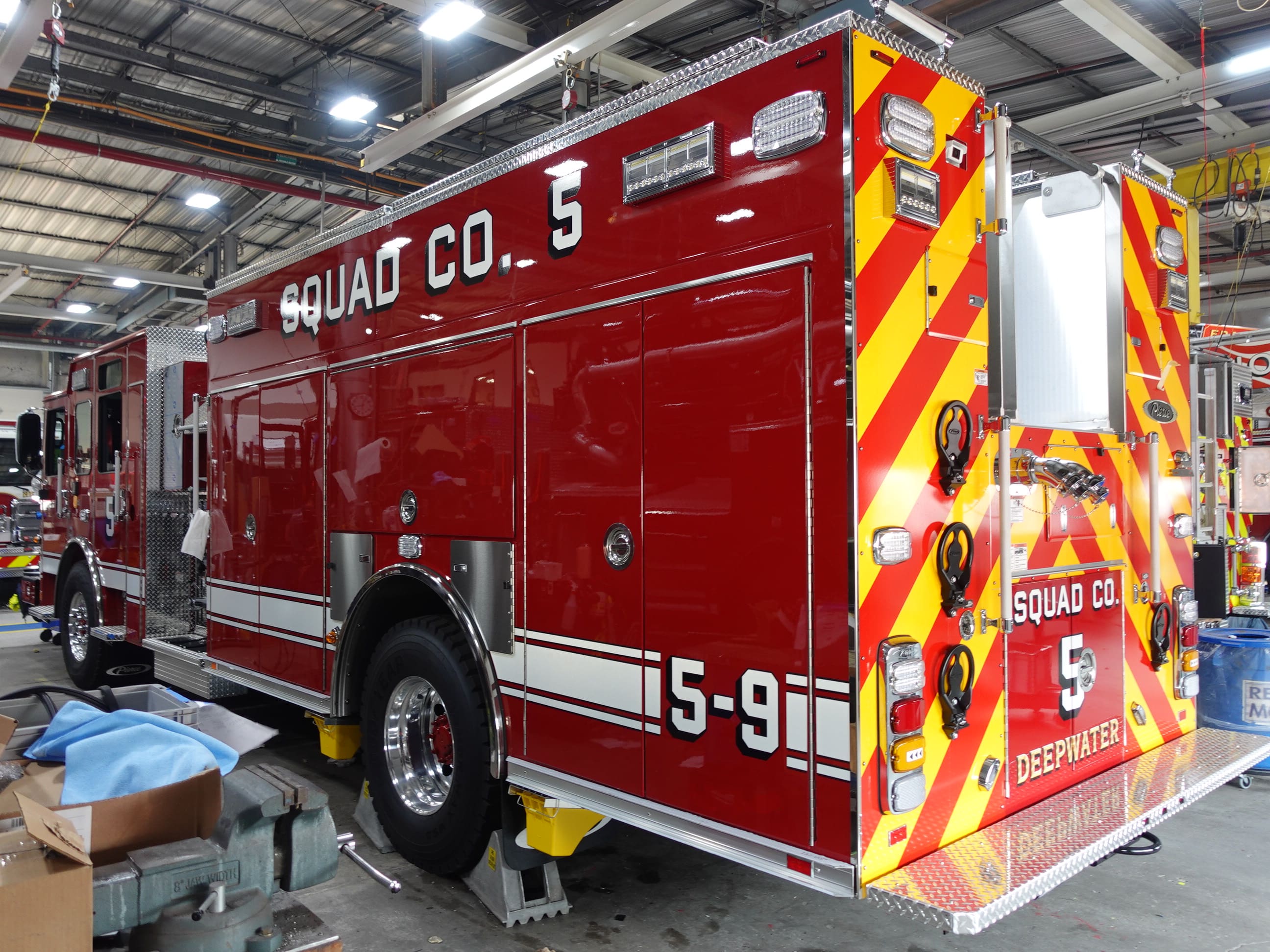

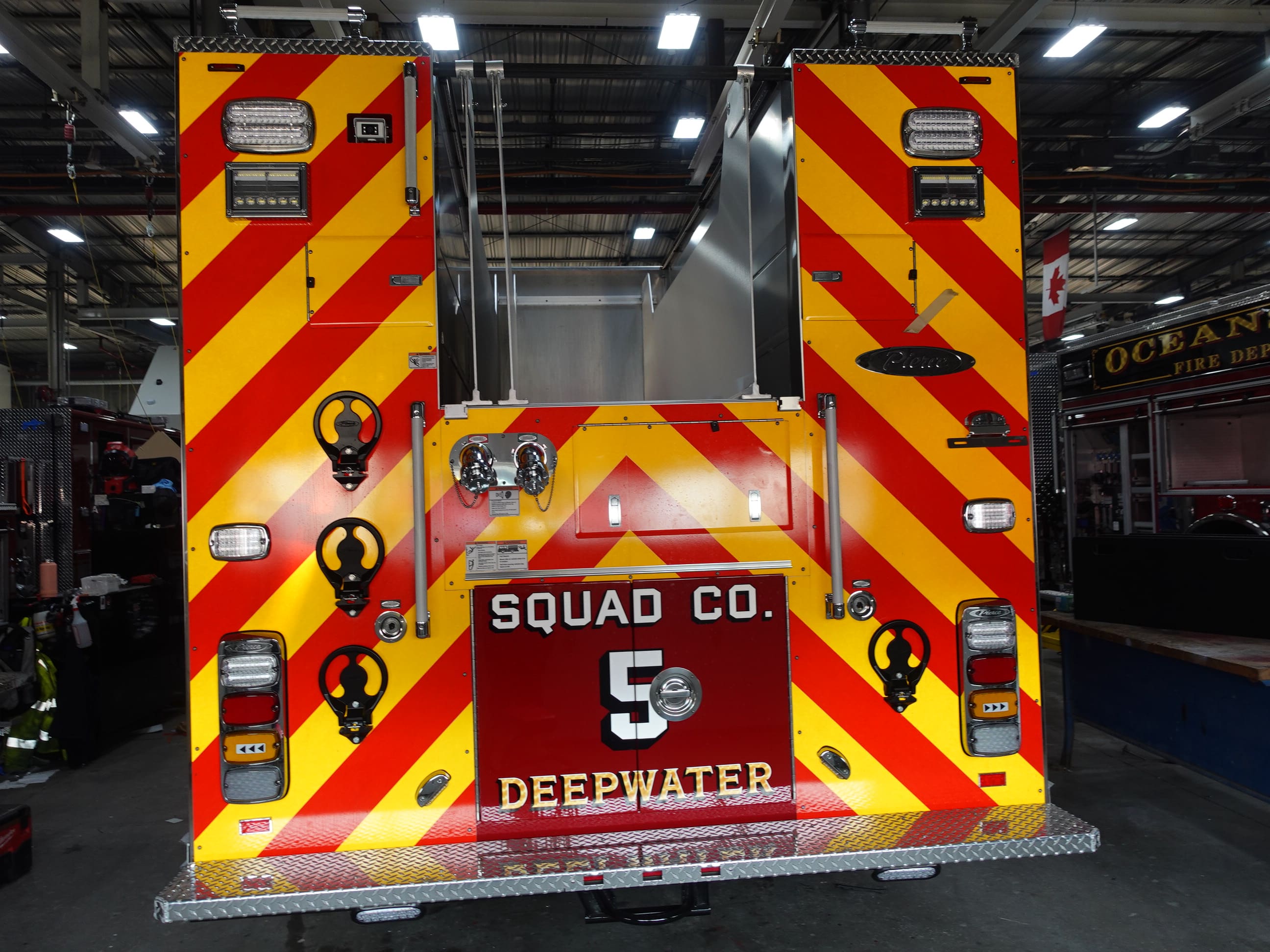

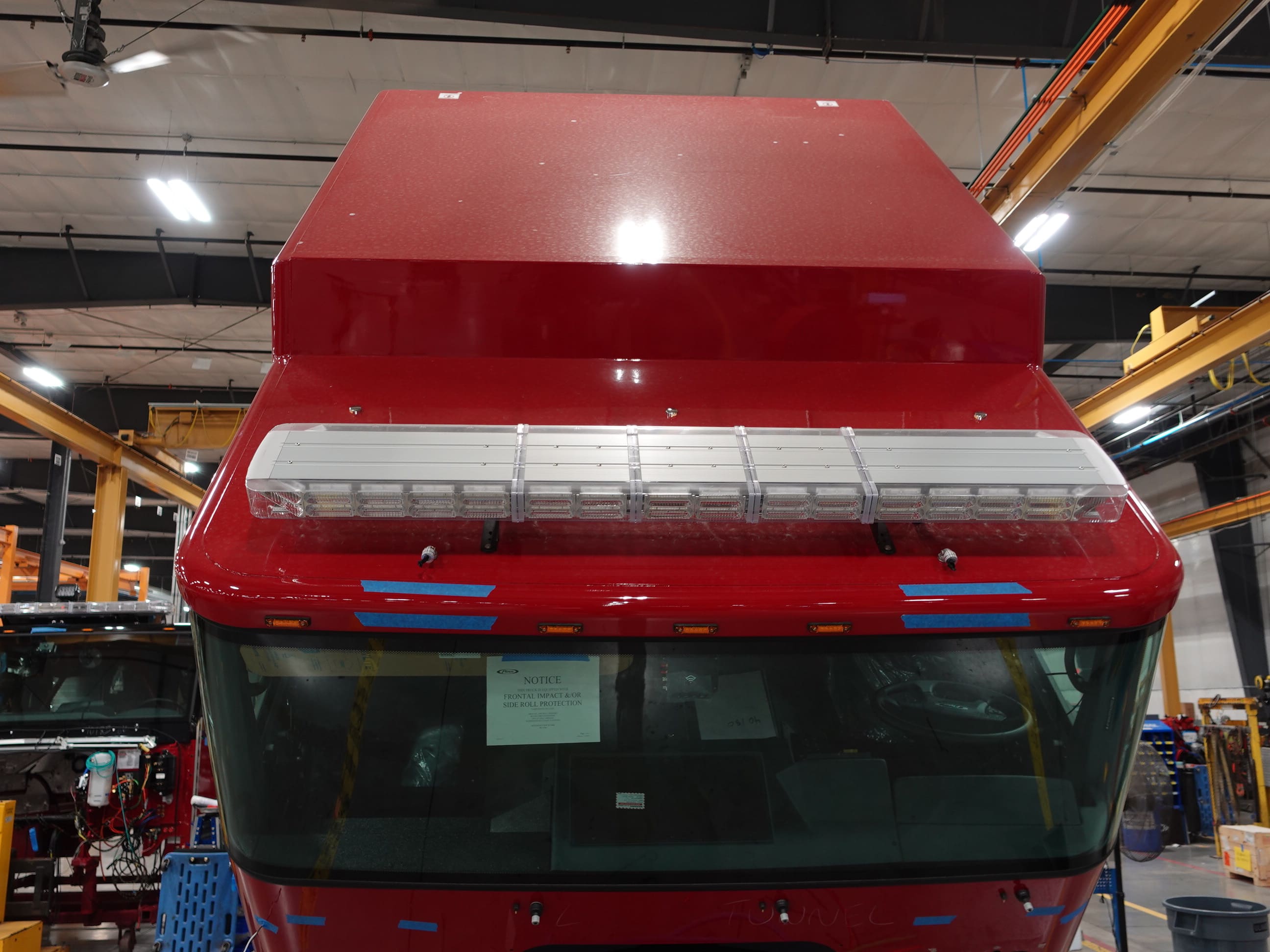

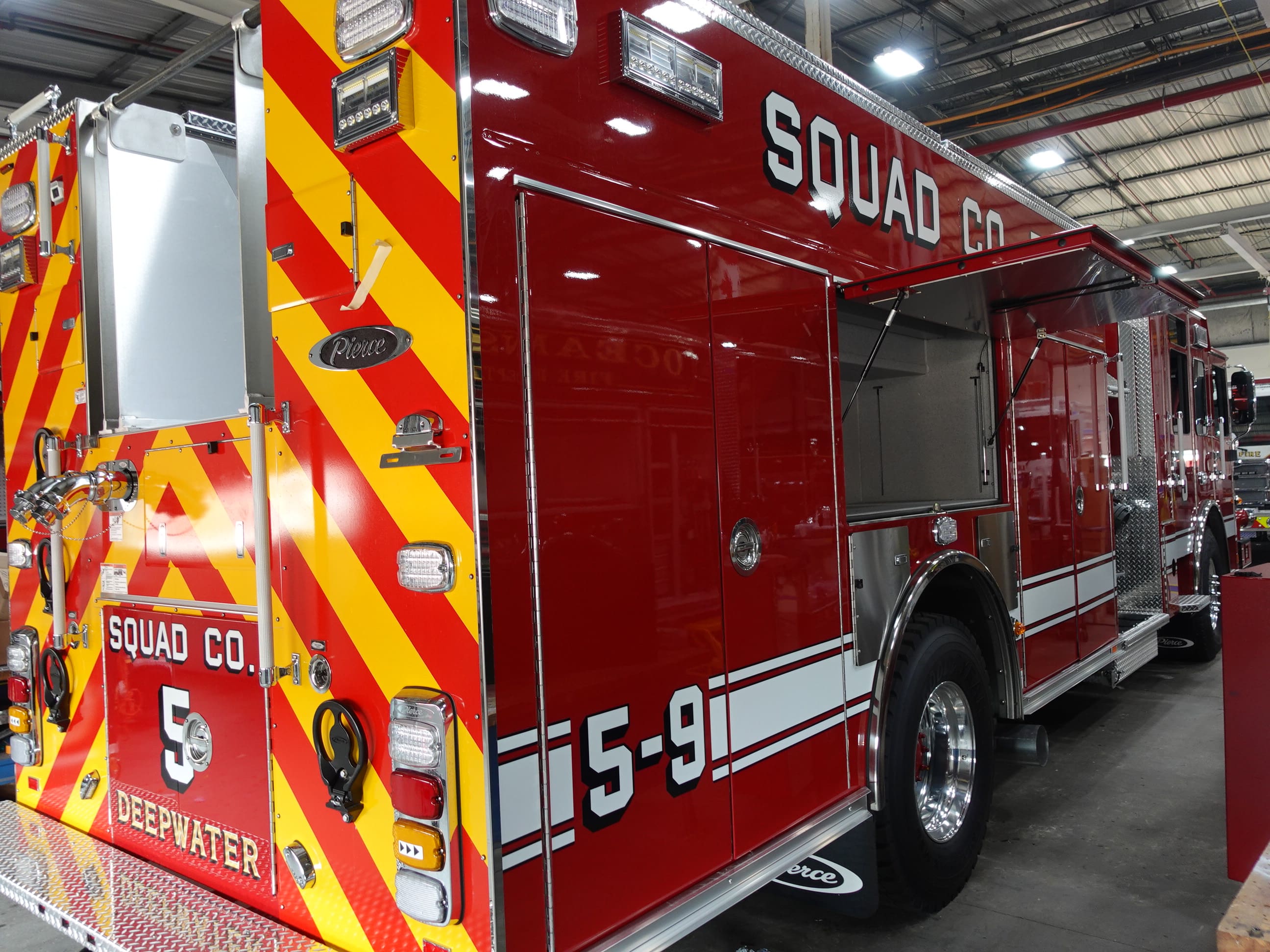

will be made ready for the customer acceptance inspection. This is the last scheduled report.

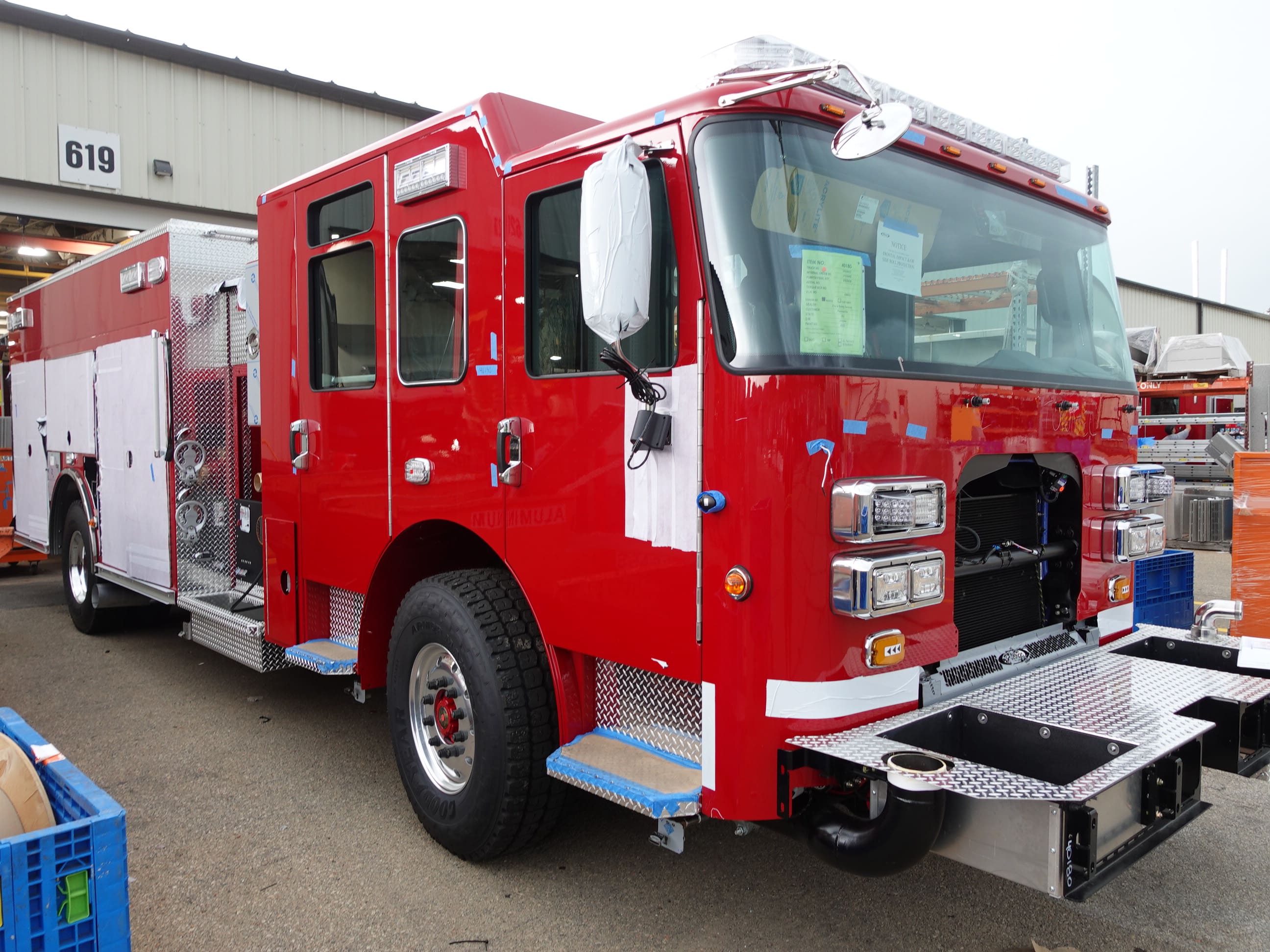

07-17-26

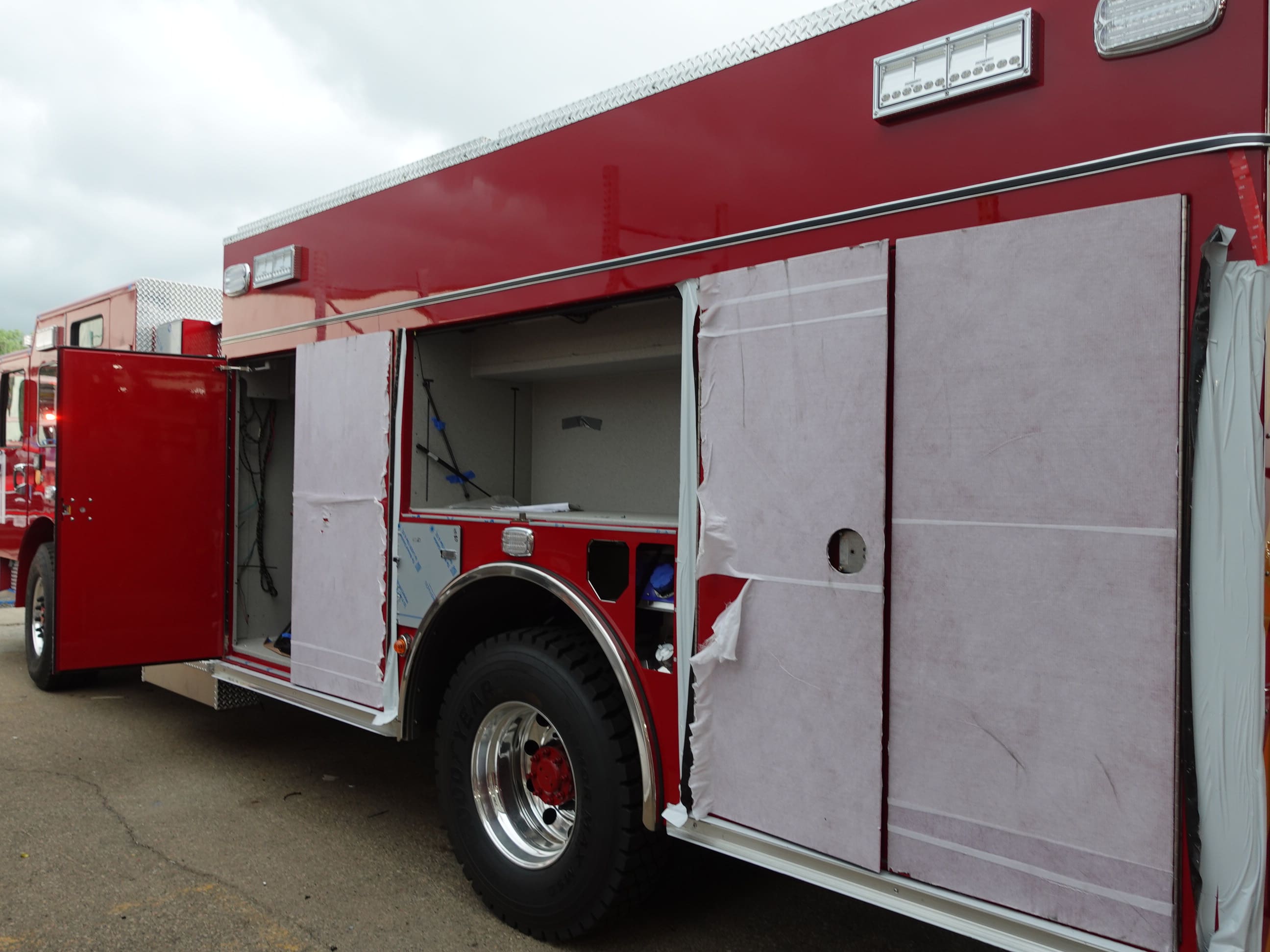

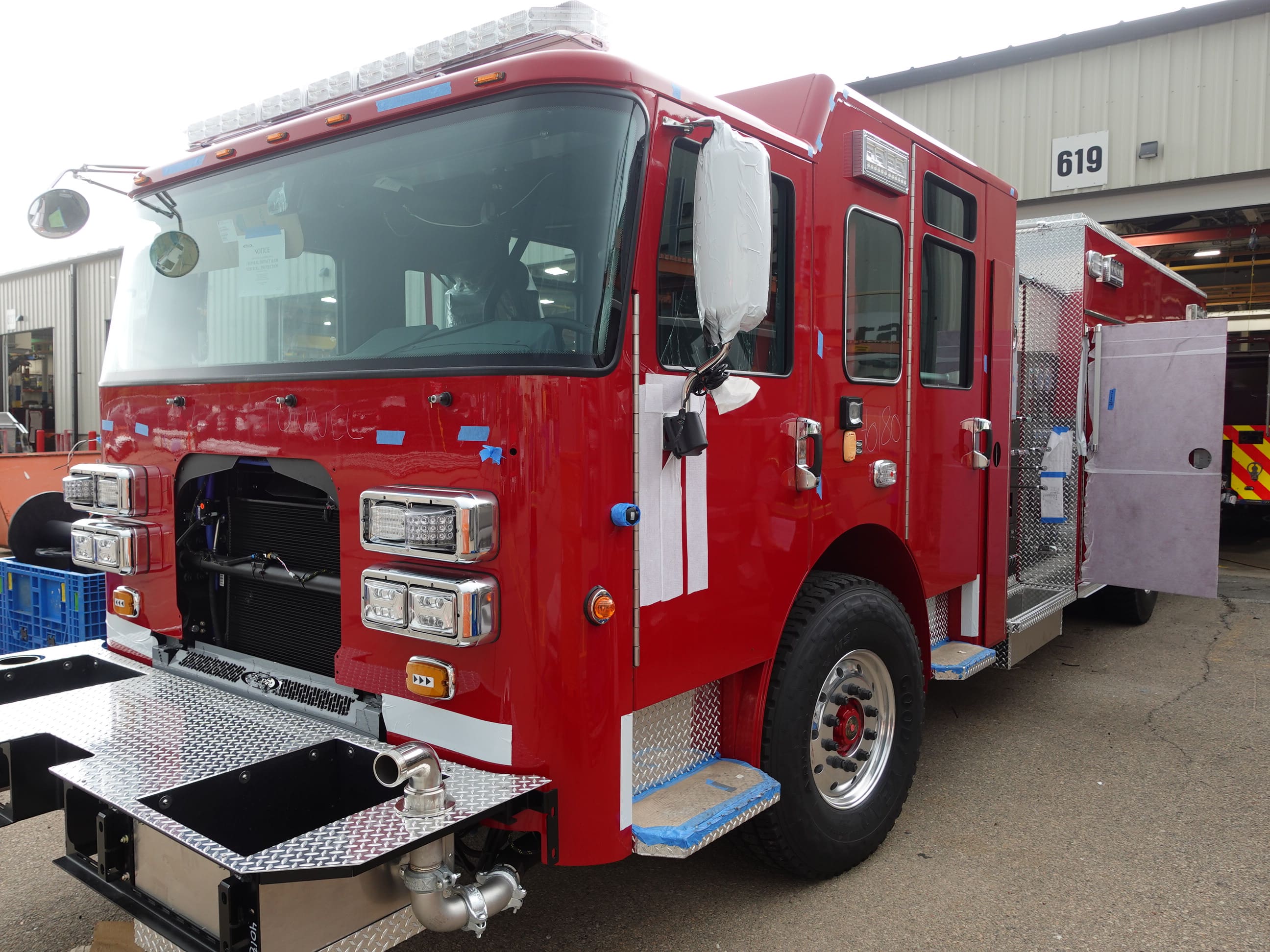

In this report, The apparatus completed test followed by release to quality and graphics where any remaining content will be applied.

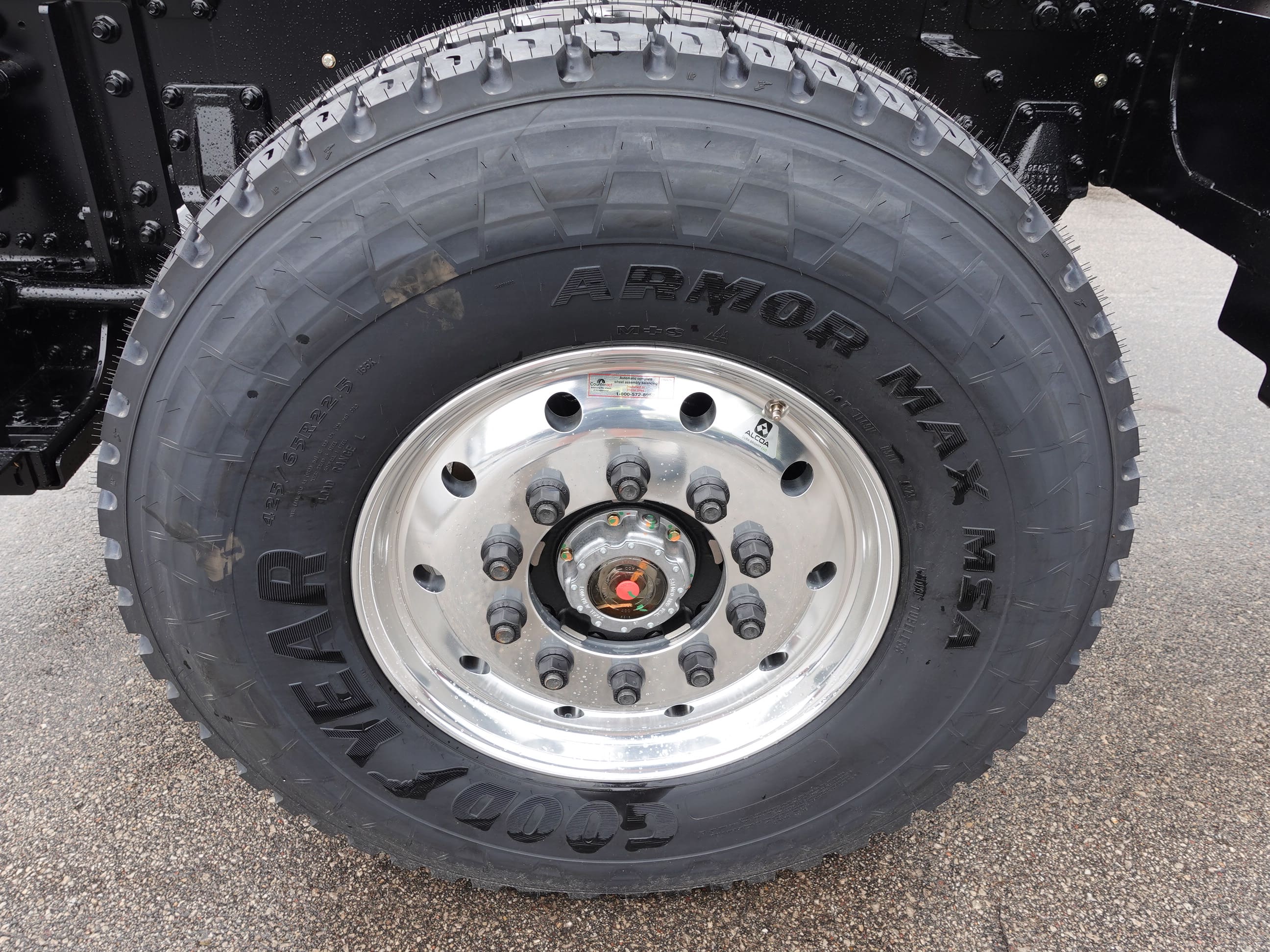

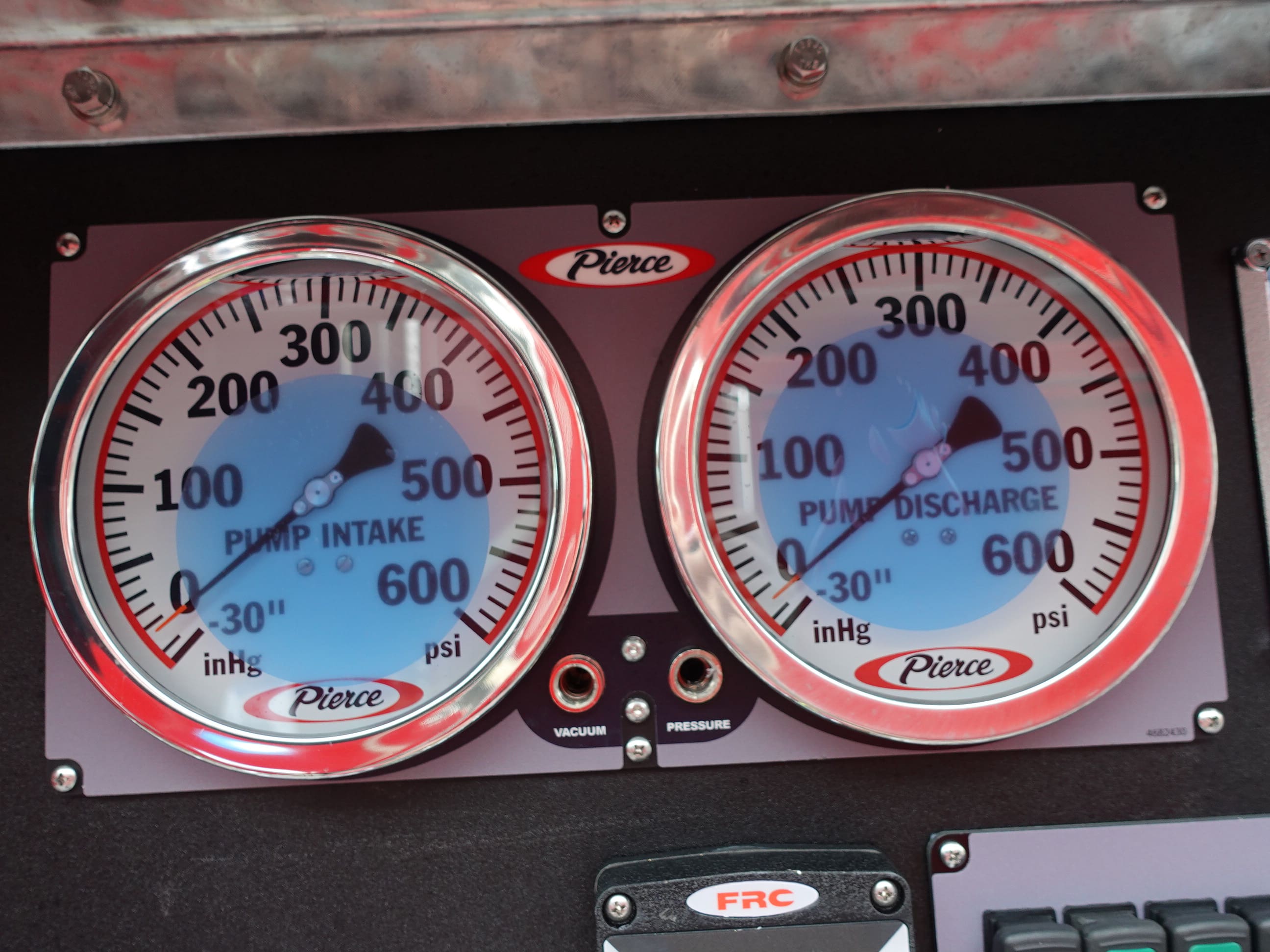

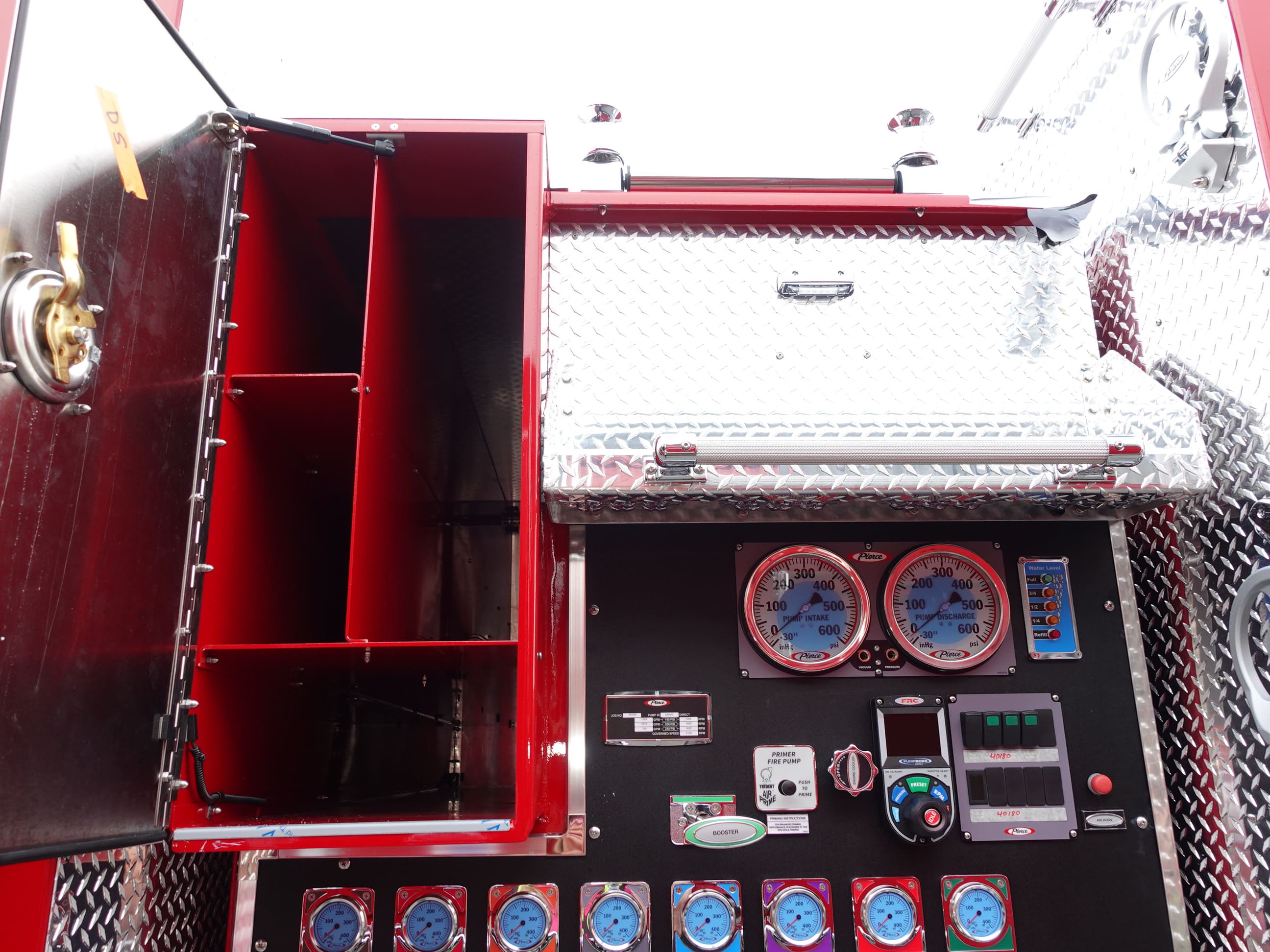

06-26-26

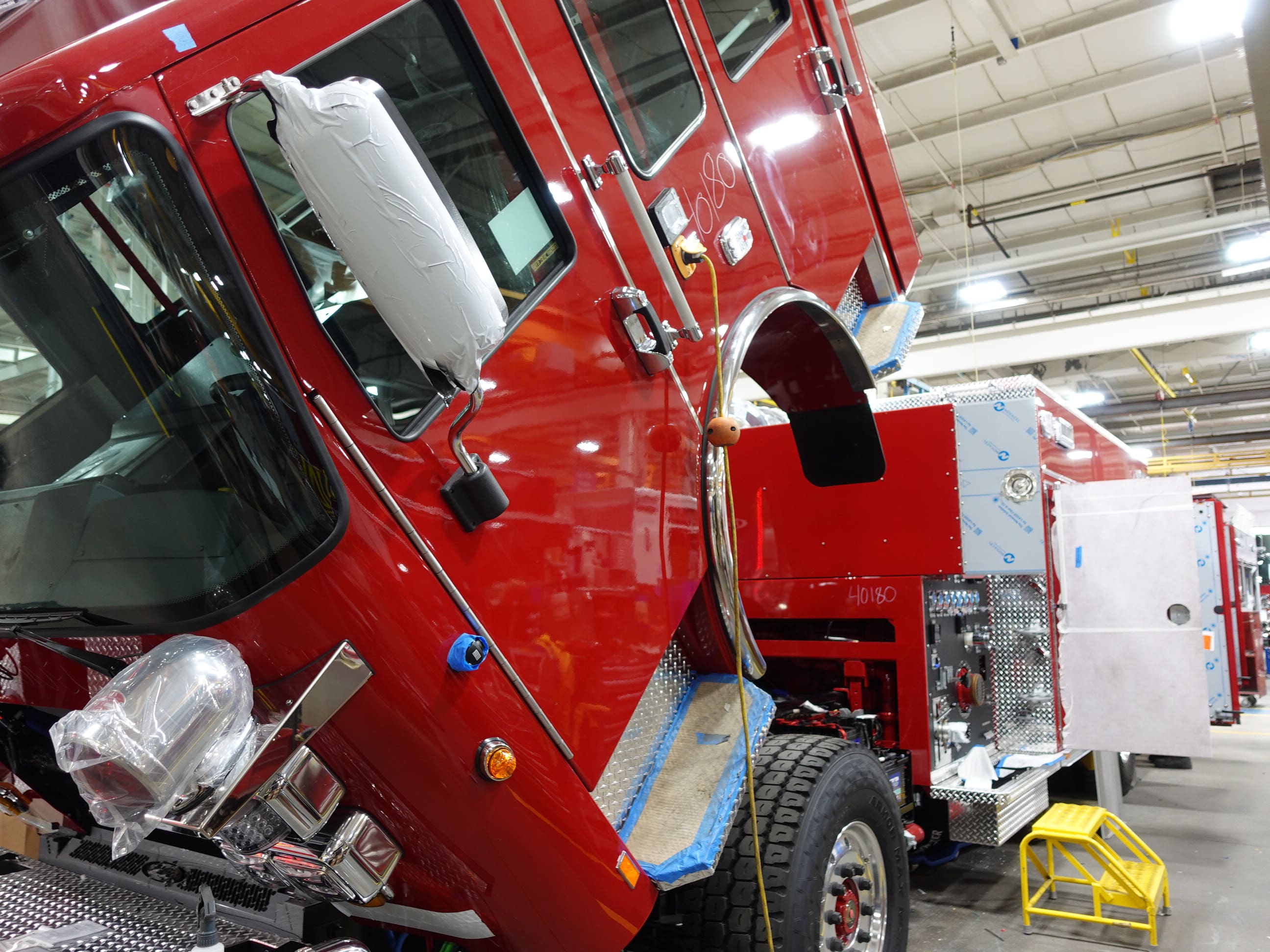

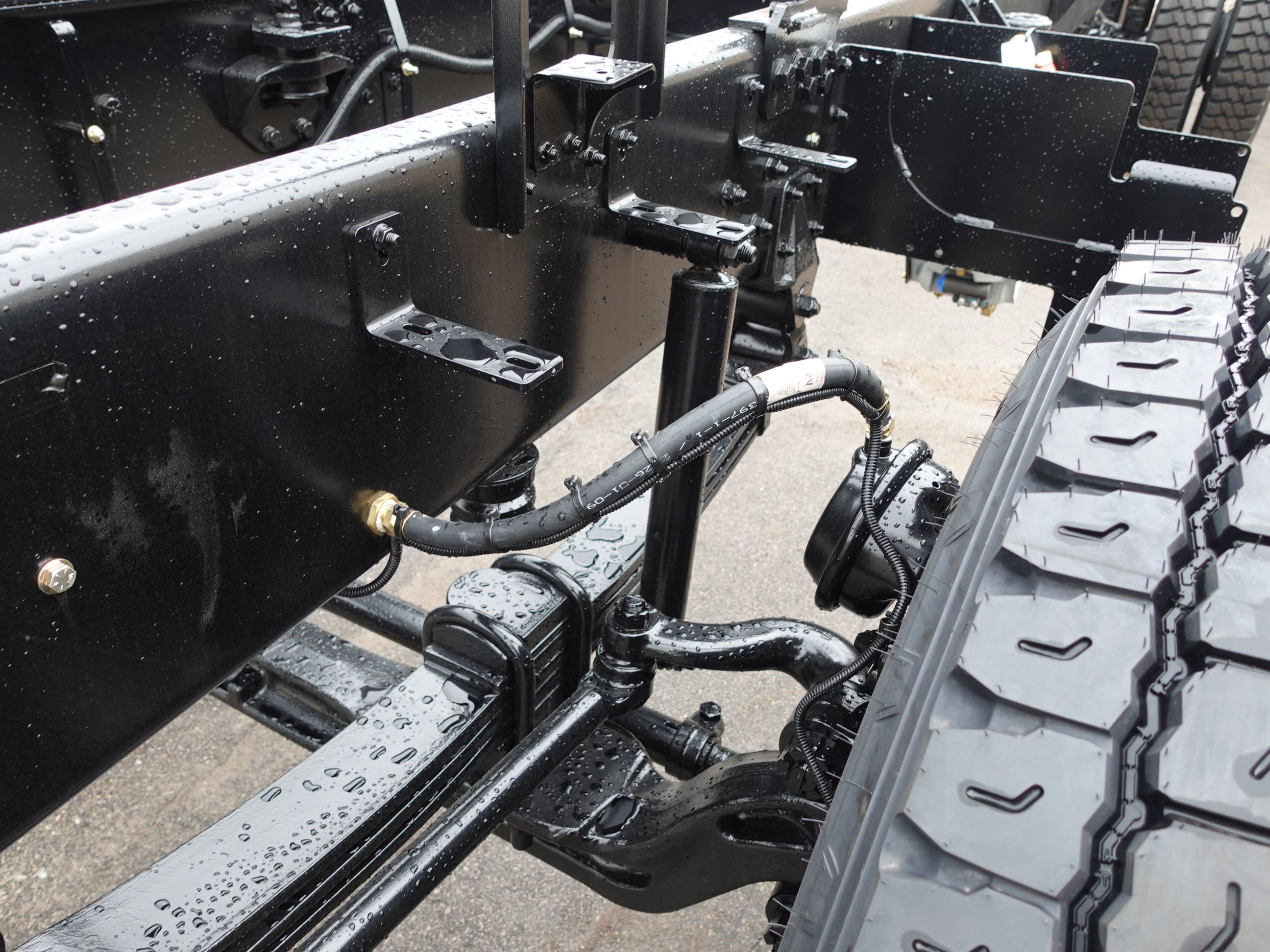

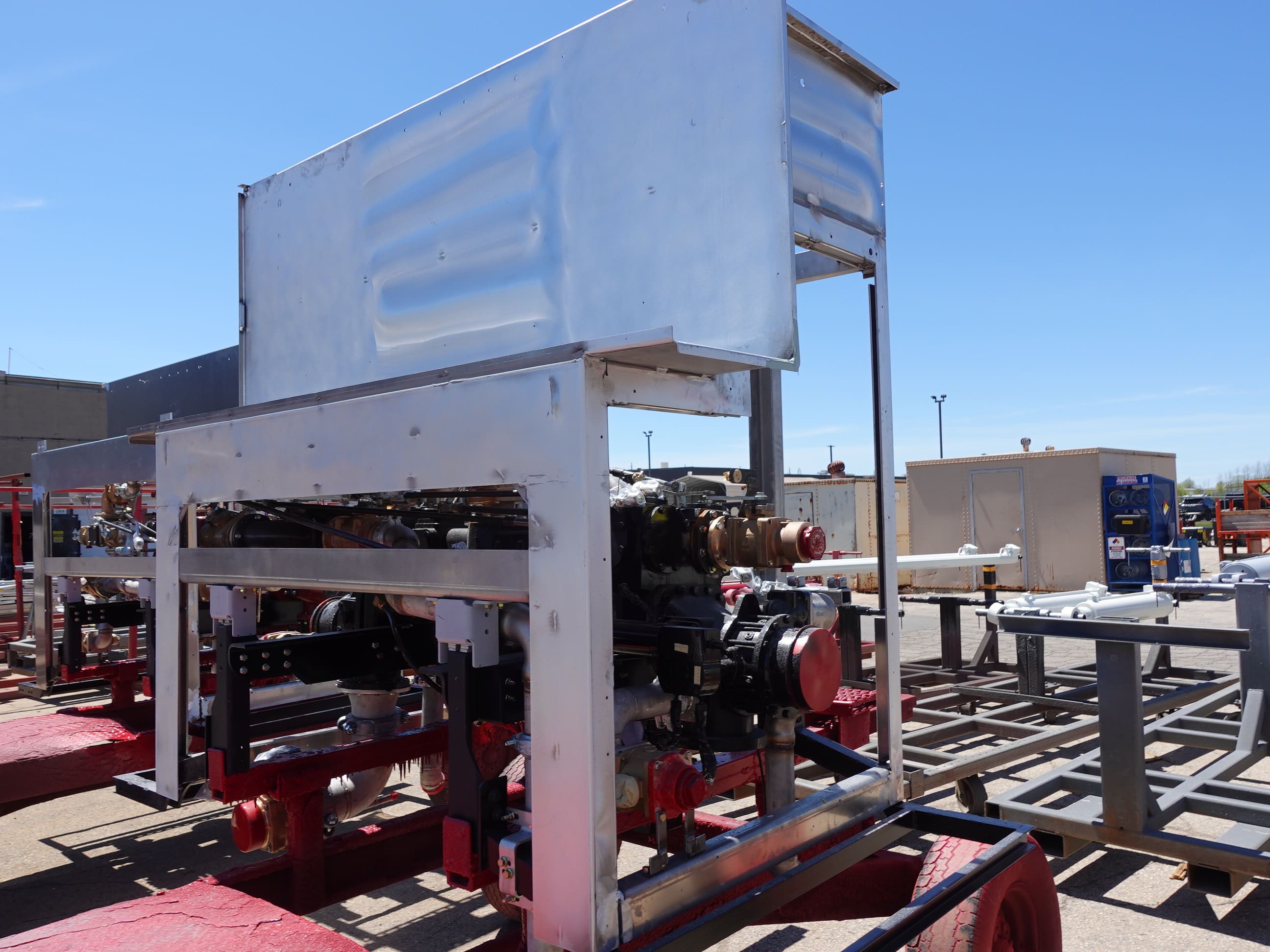

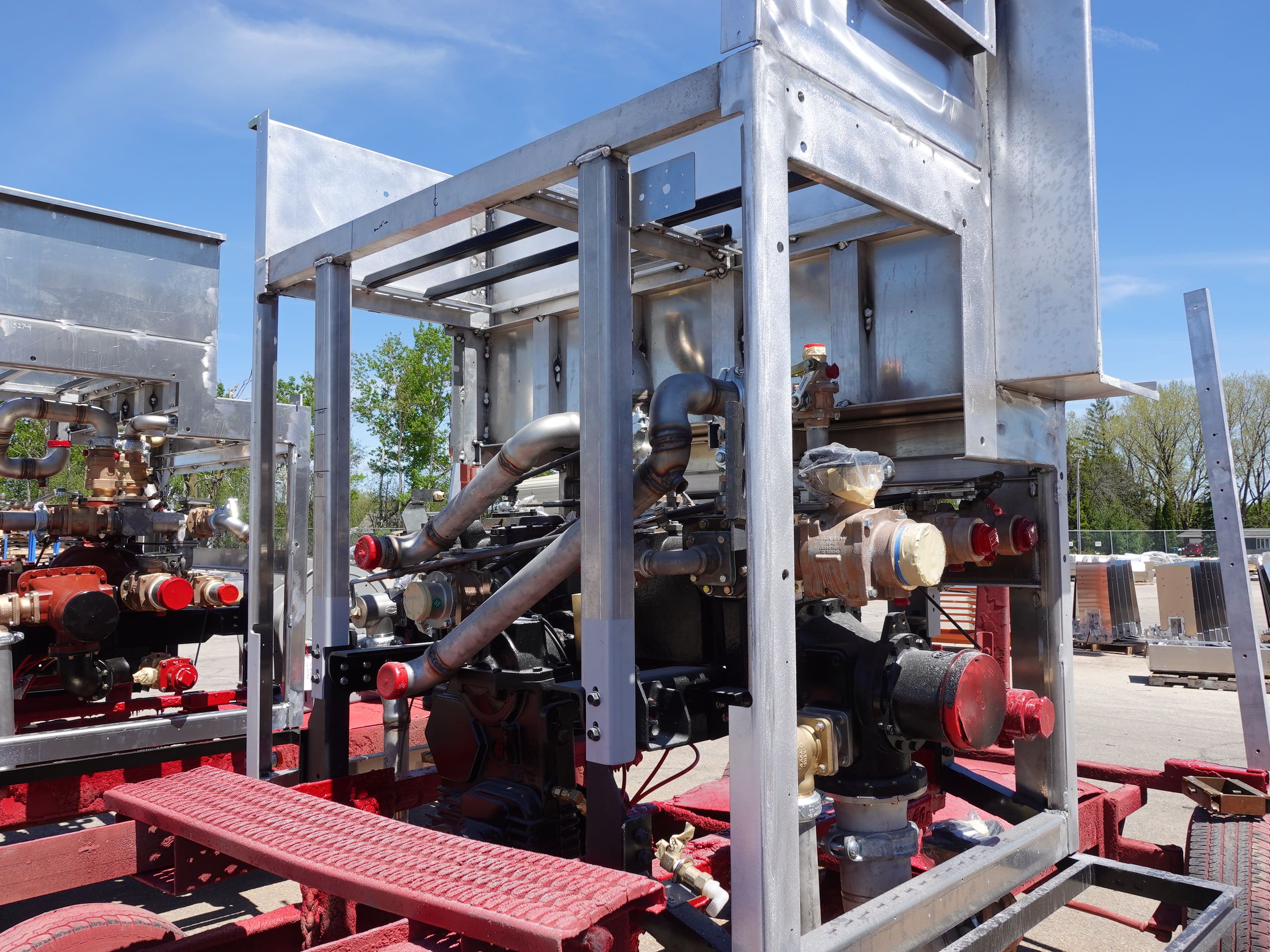

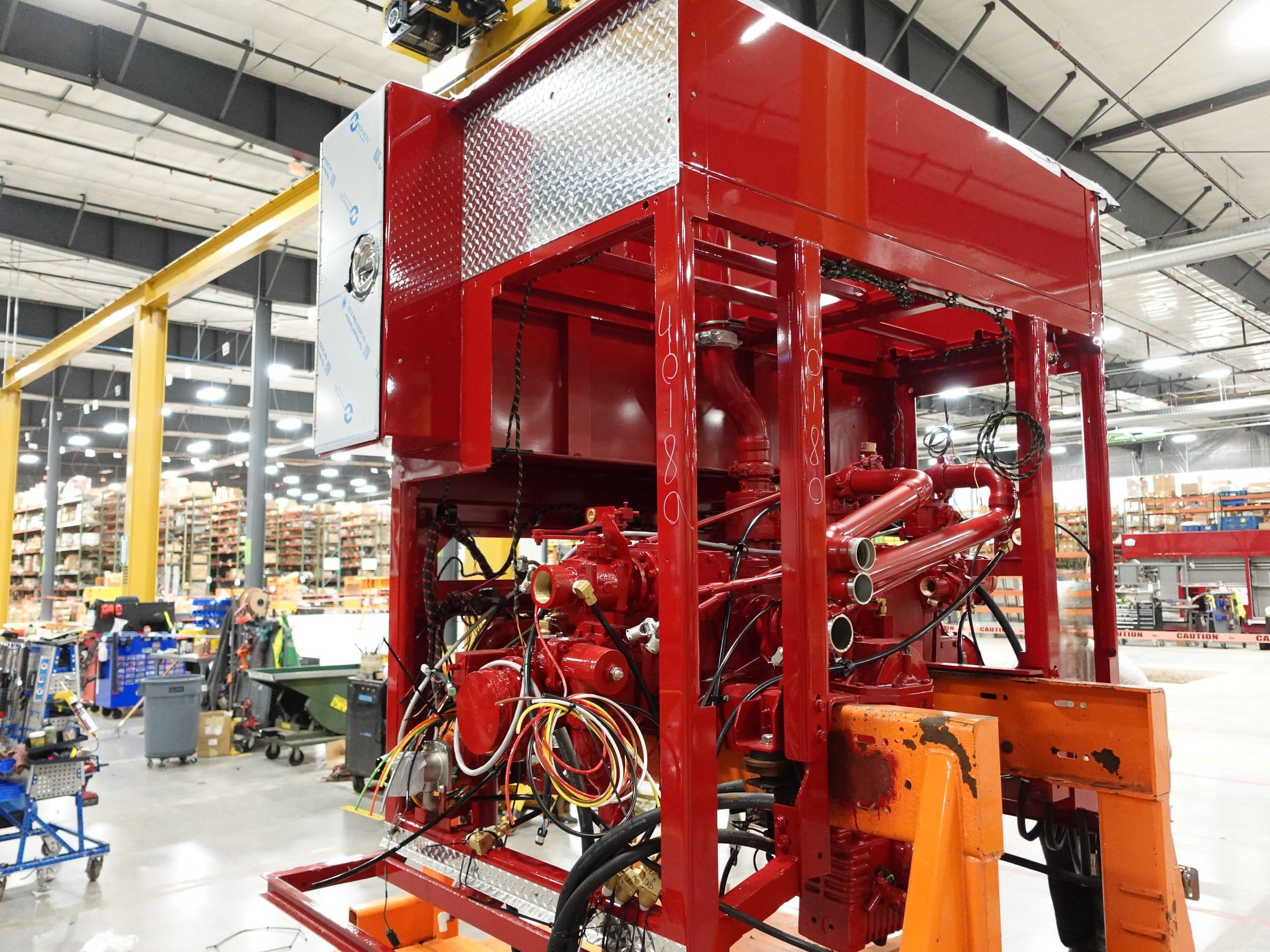

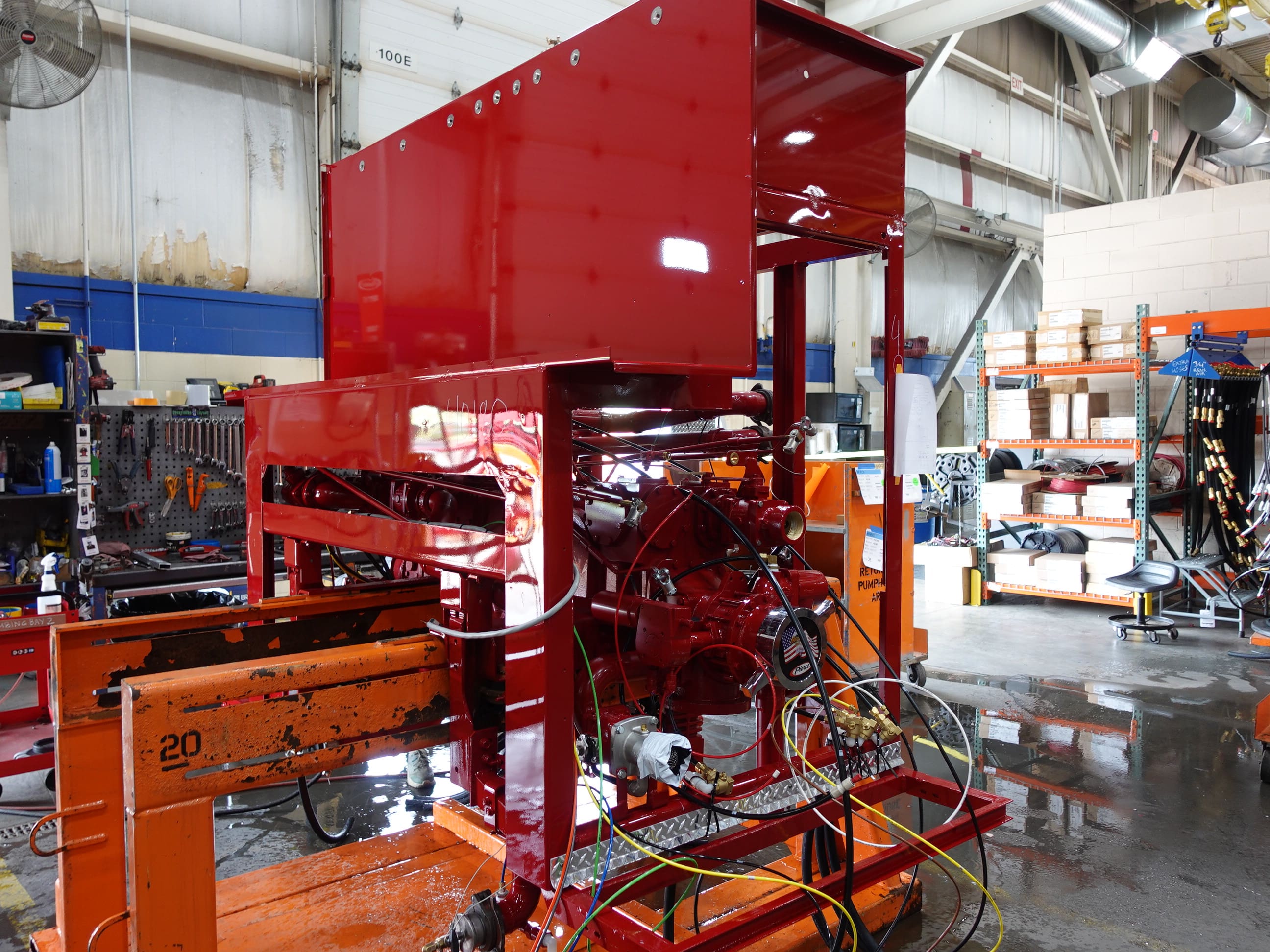

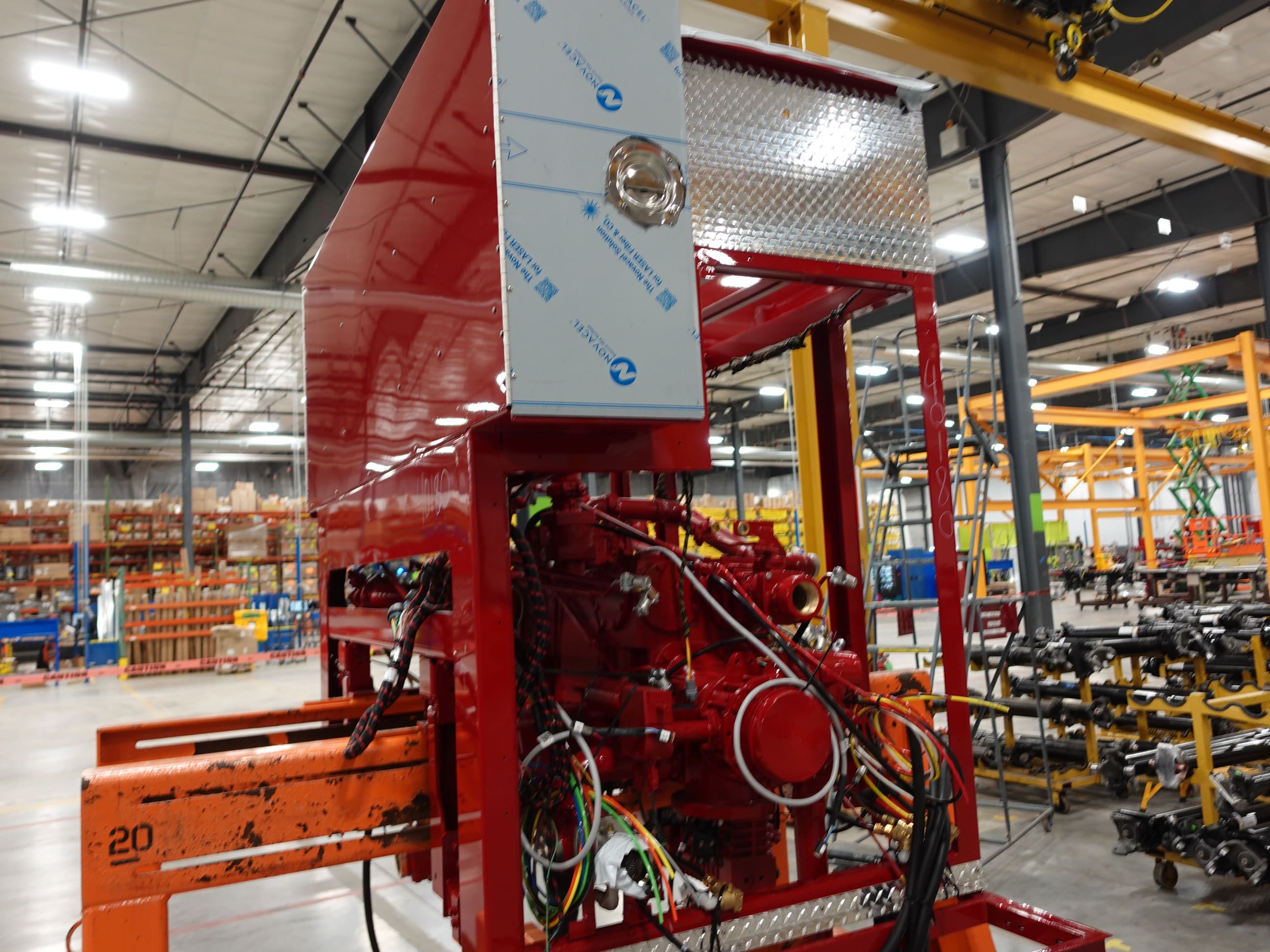

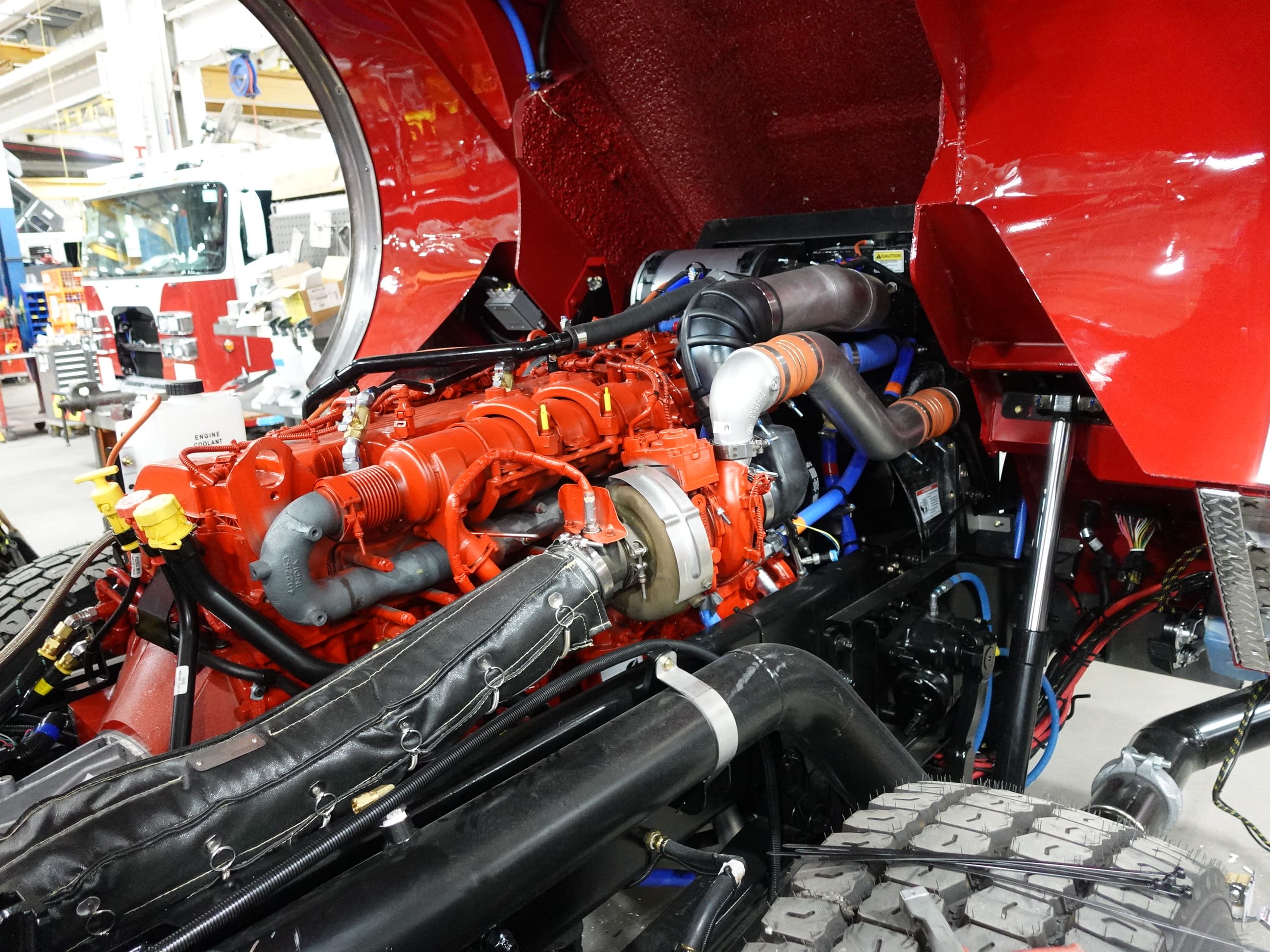

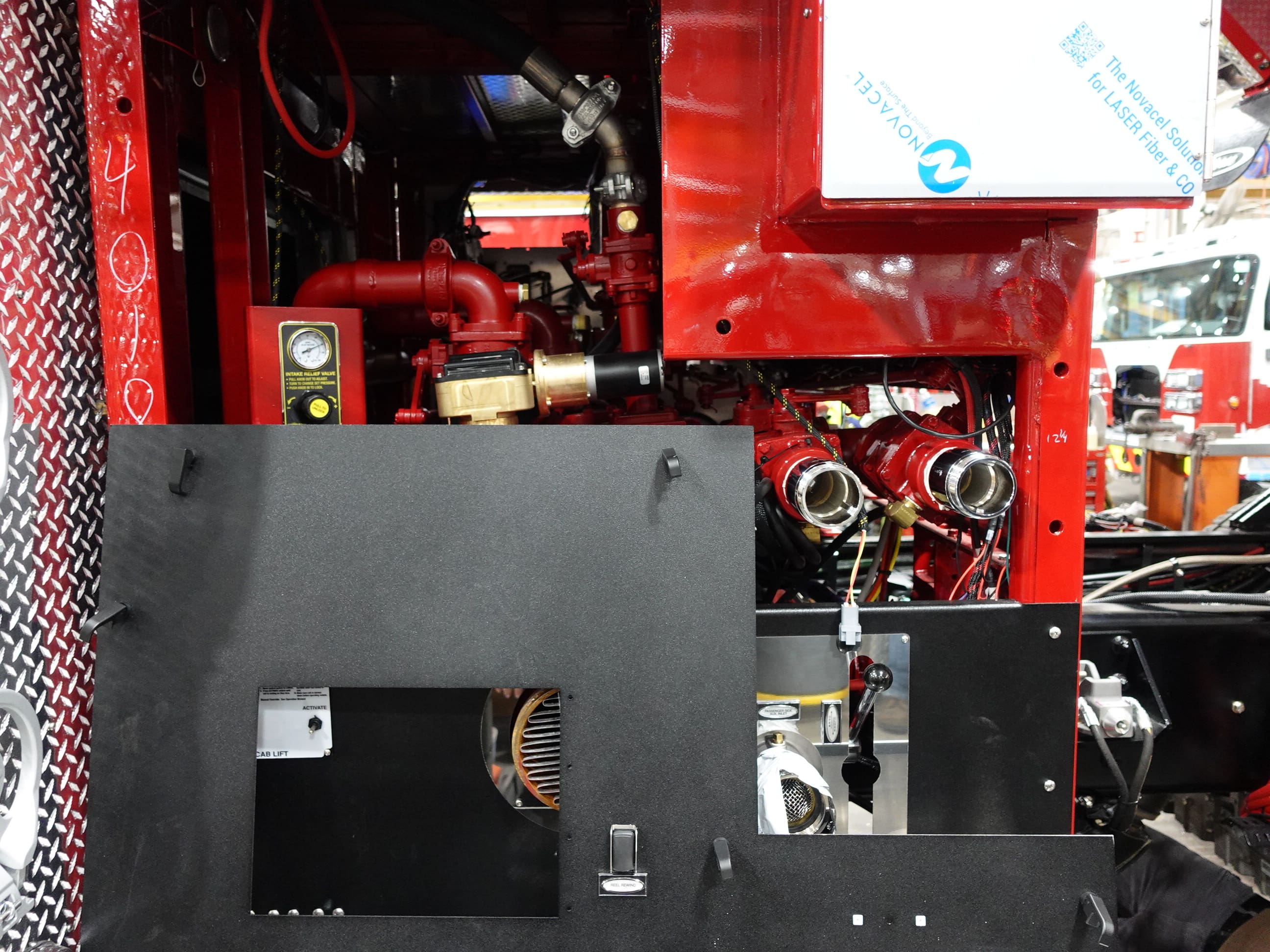

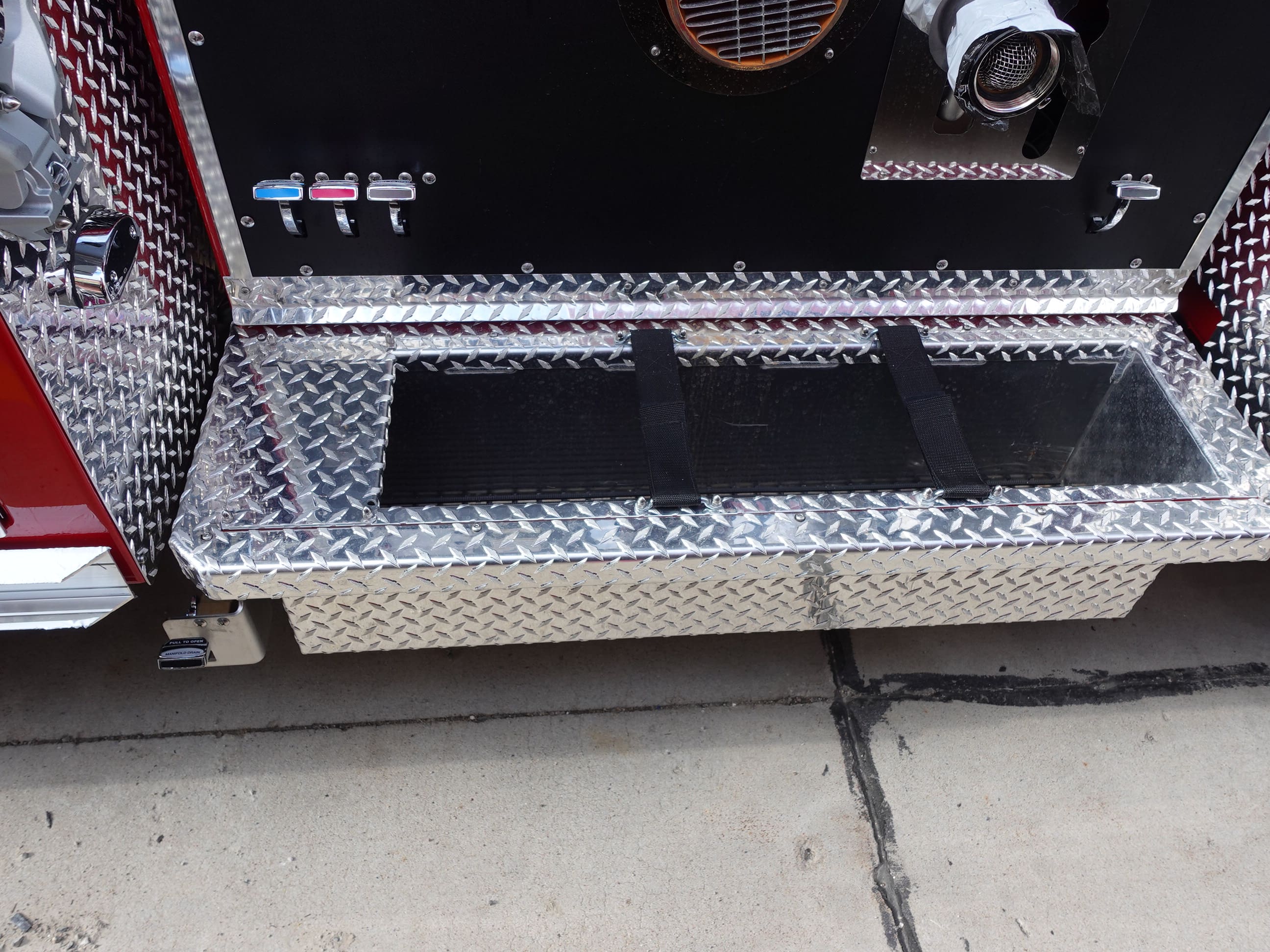

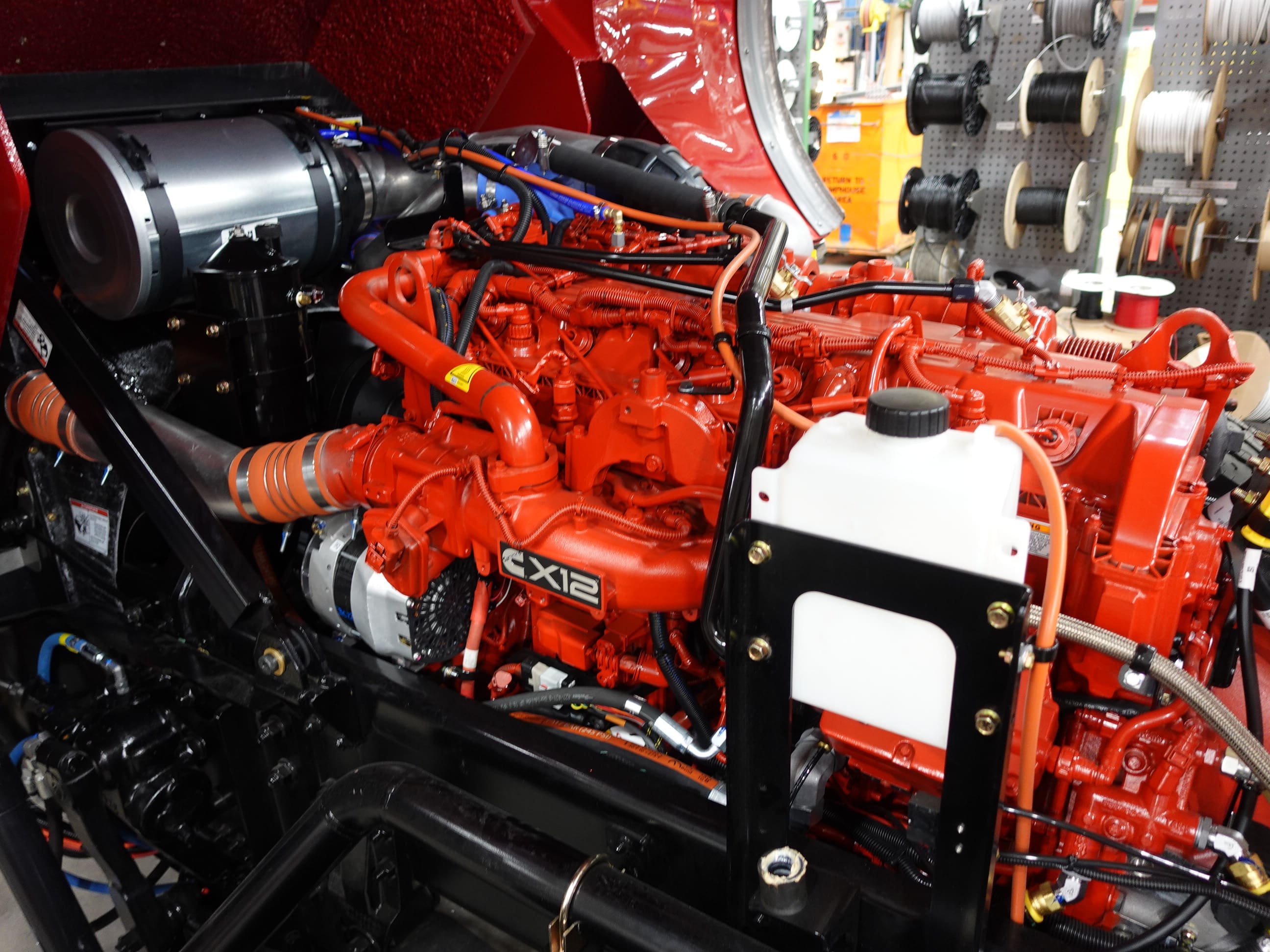

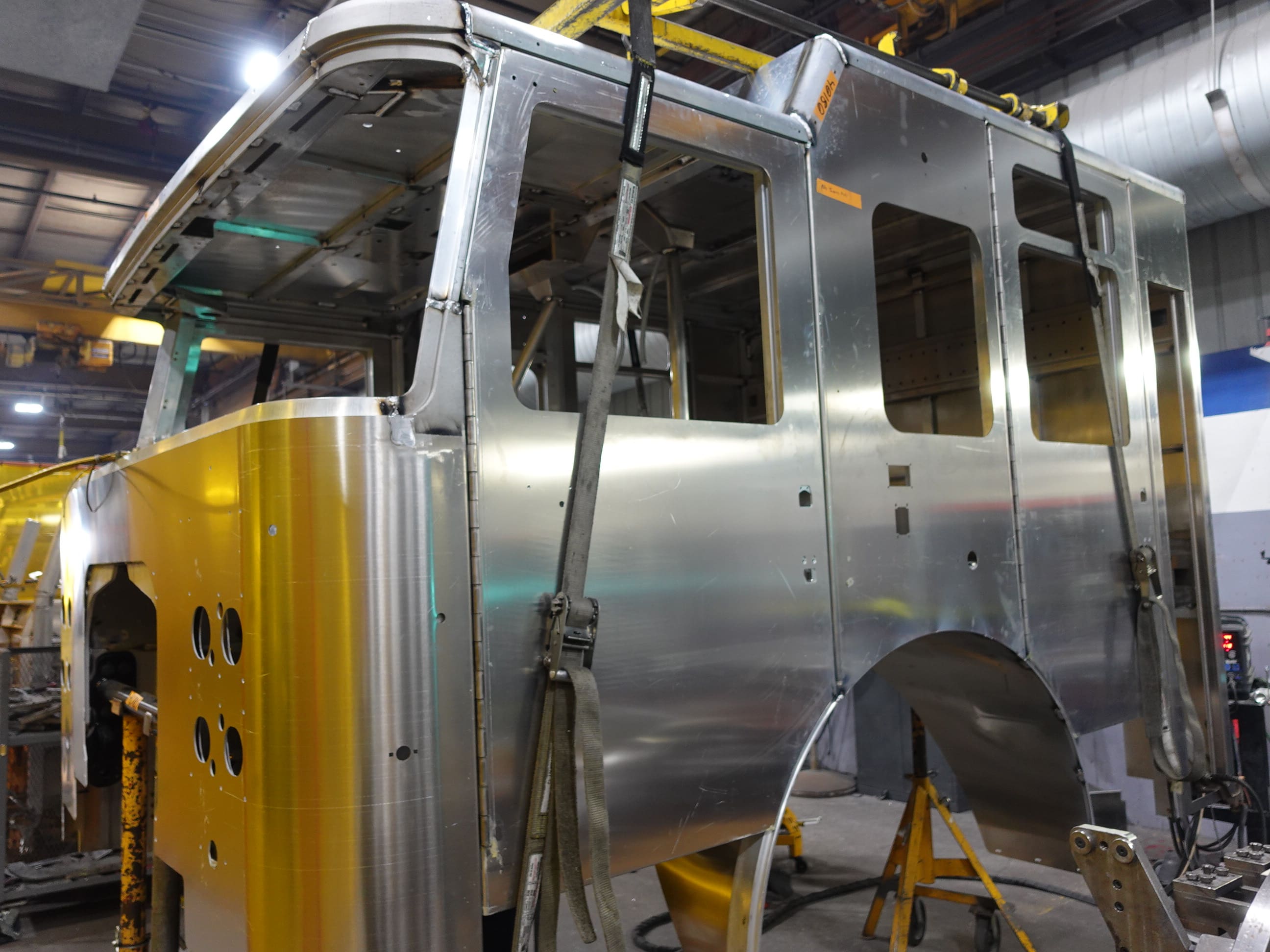

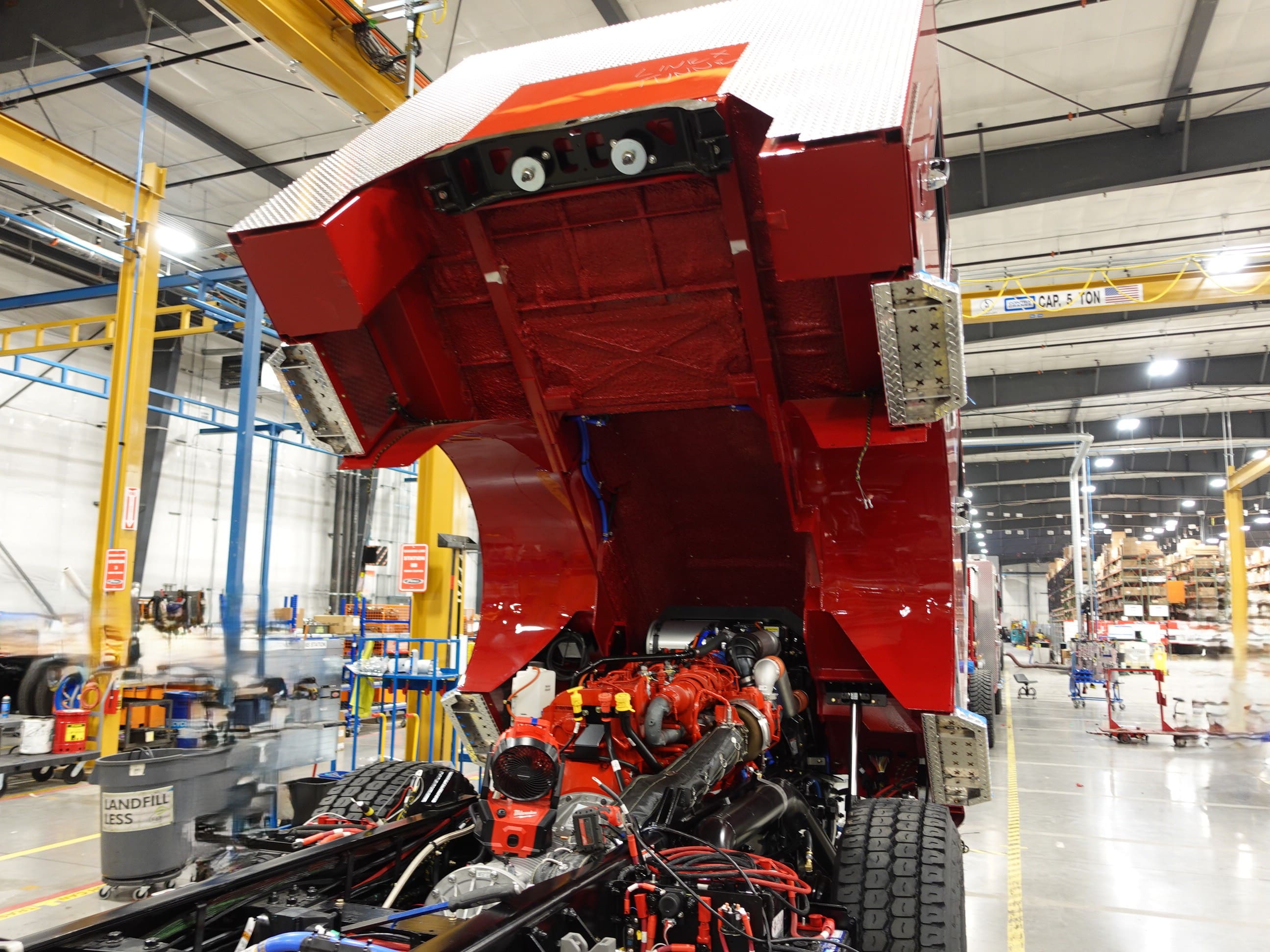

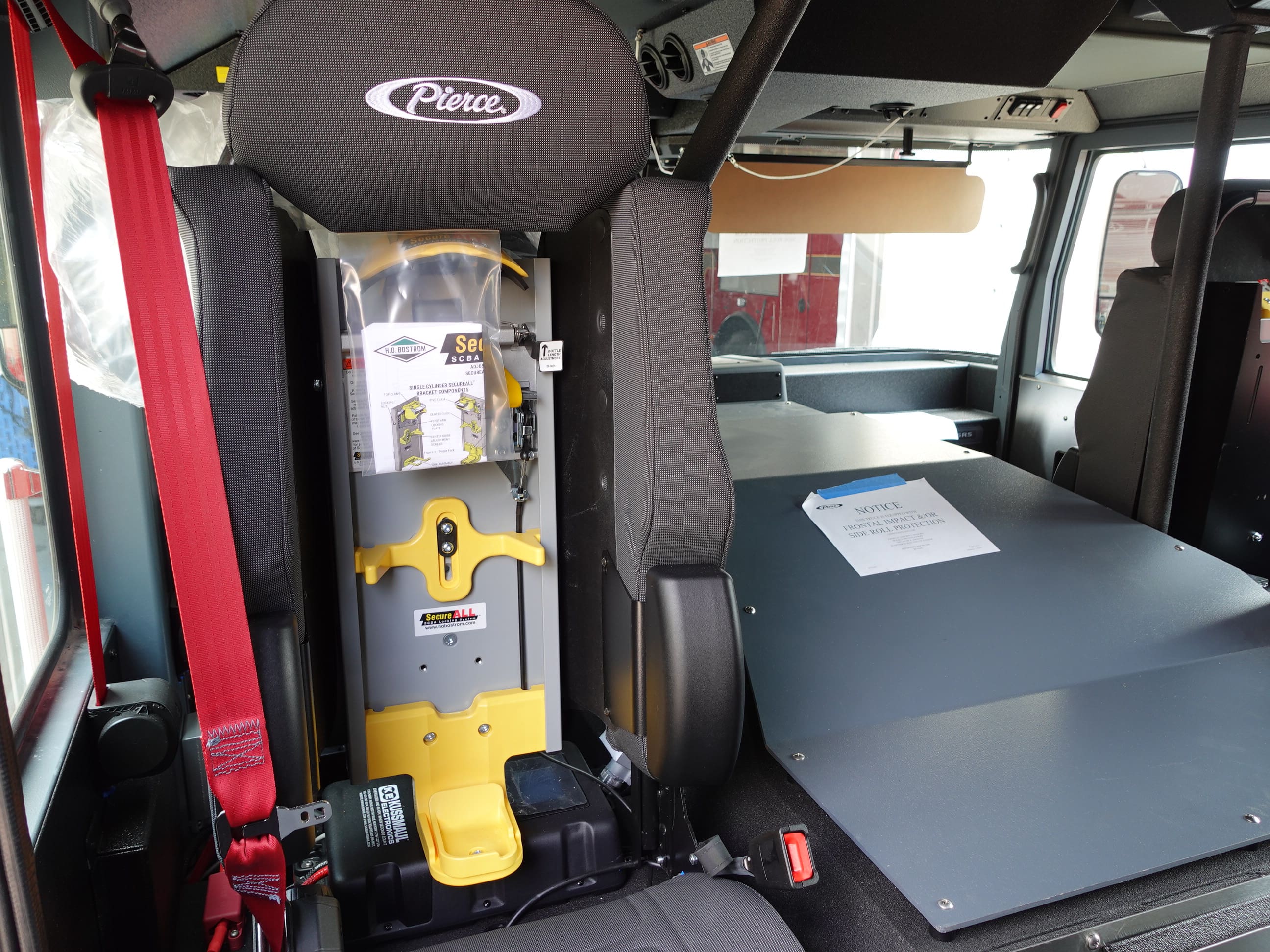

In this report, the apparatus completed final assembly and began test. When testing completes it will release to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance
inspection. This is the last scheduled report.

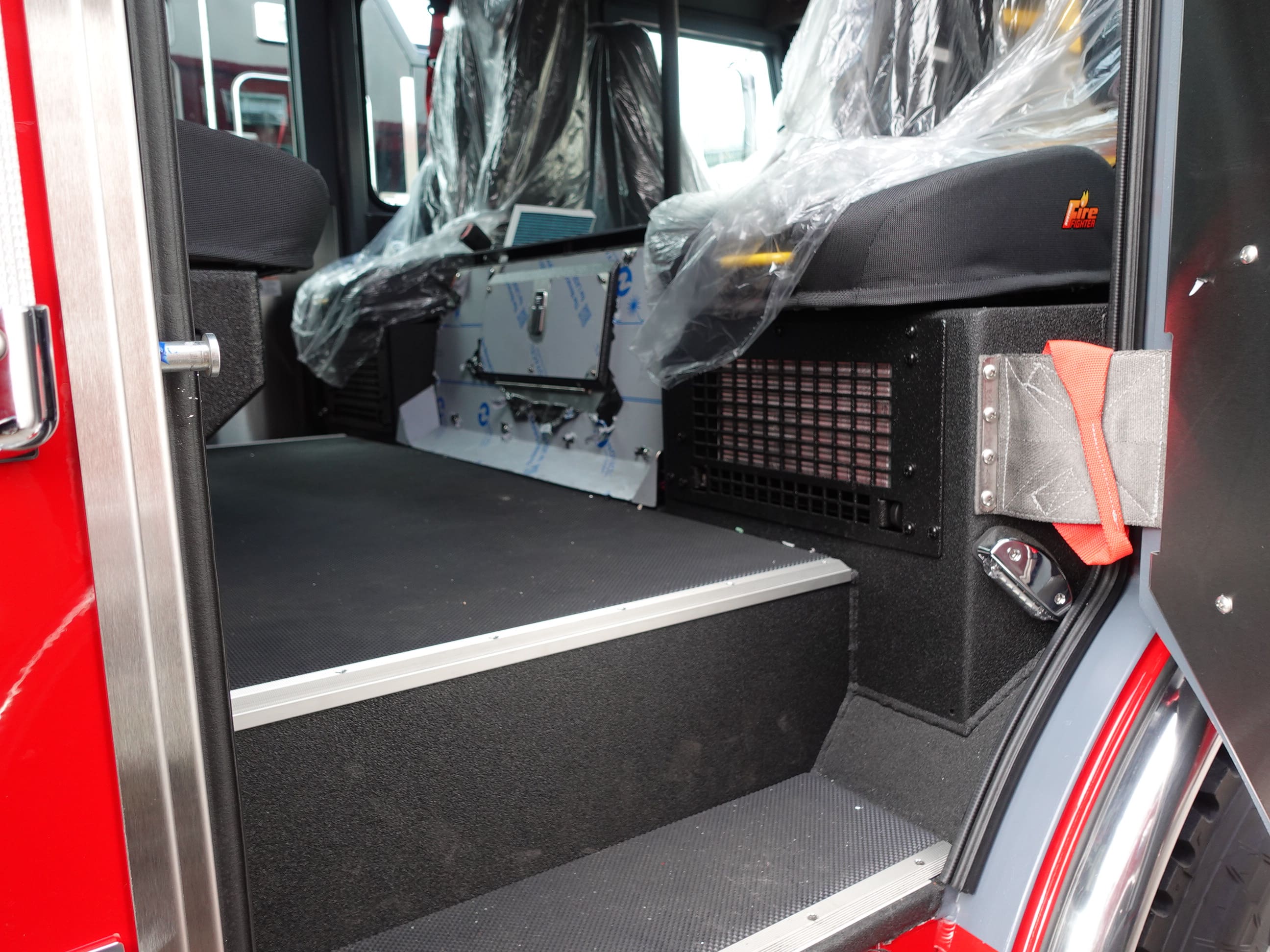

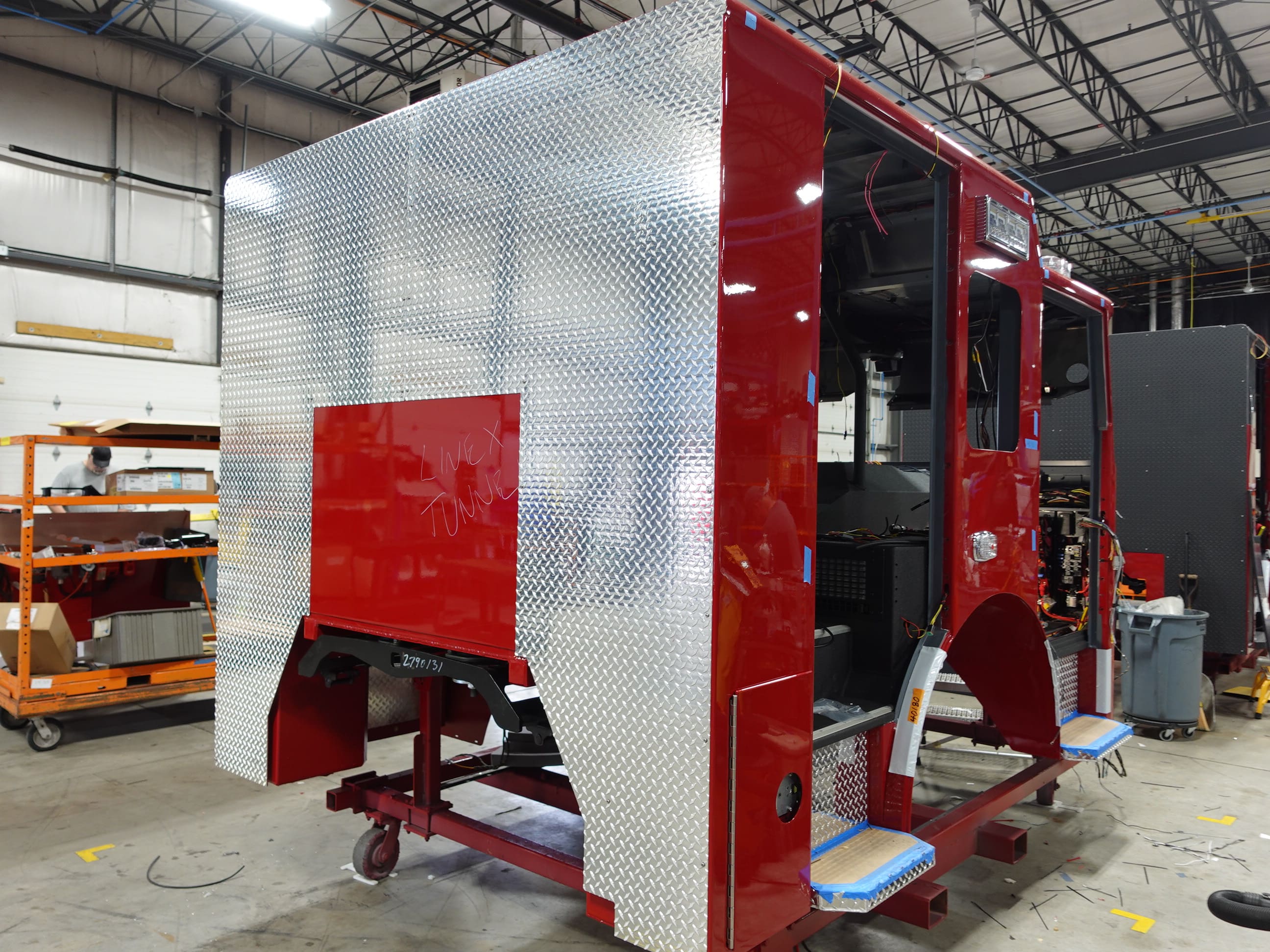

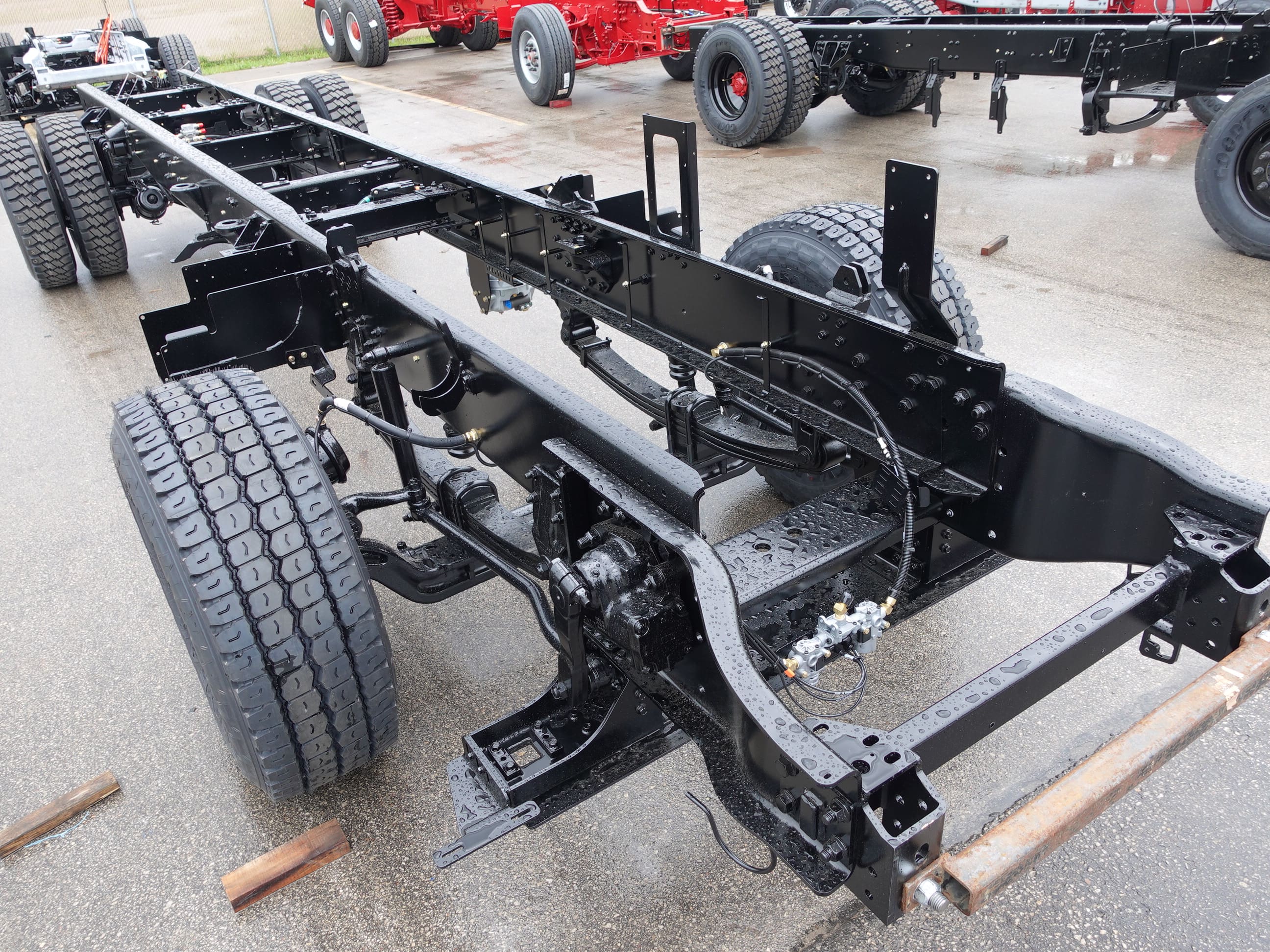

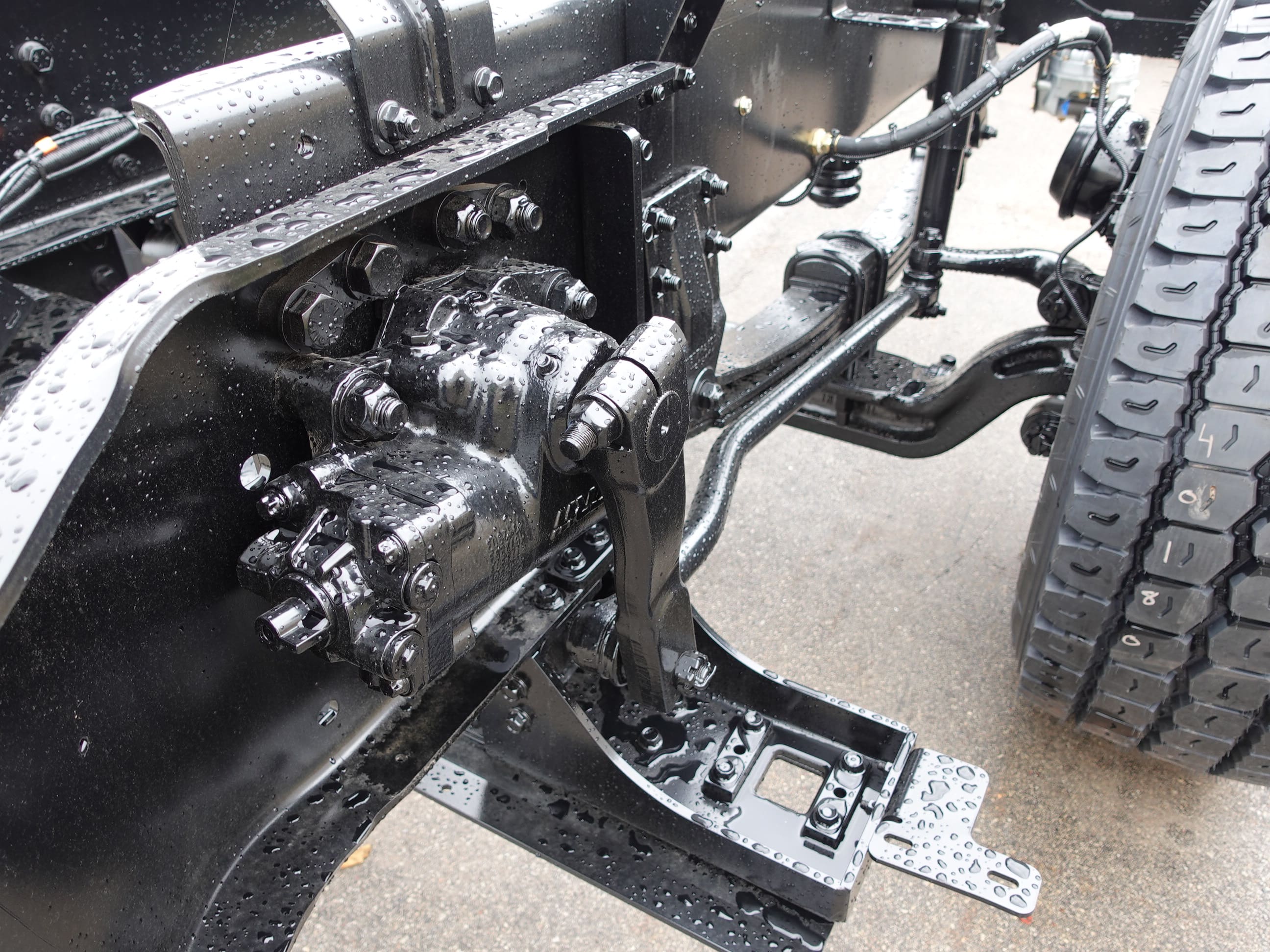

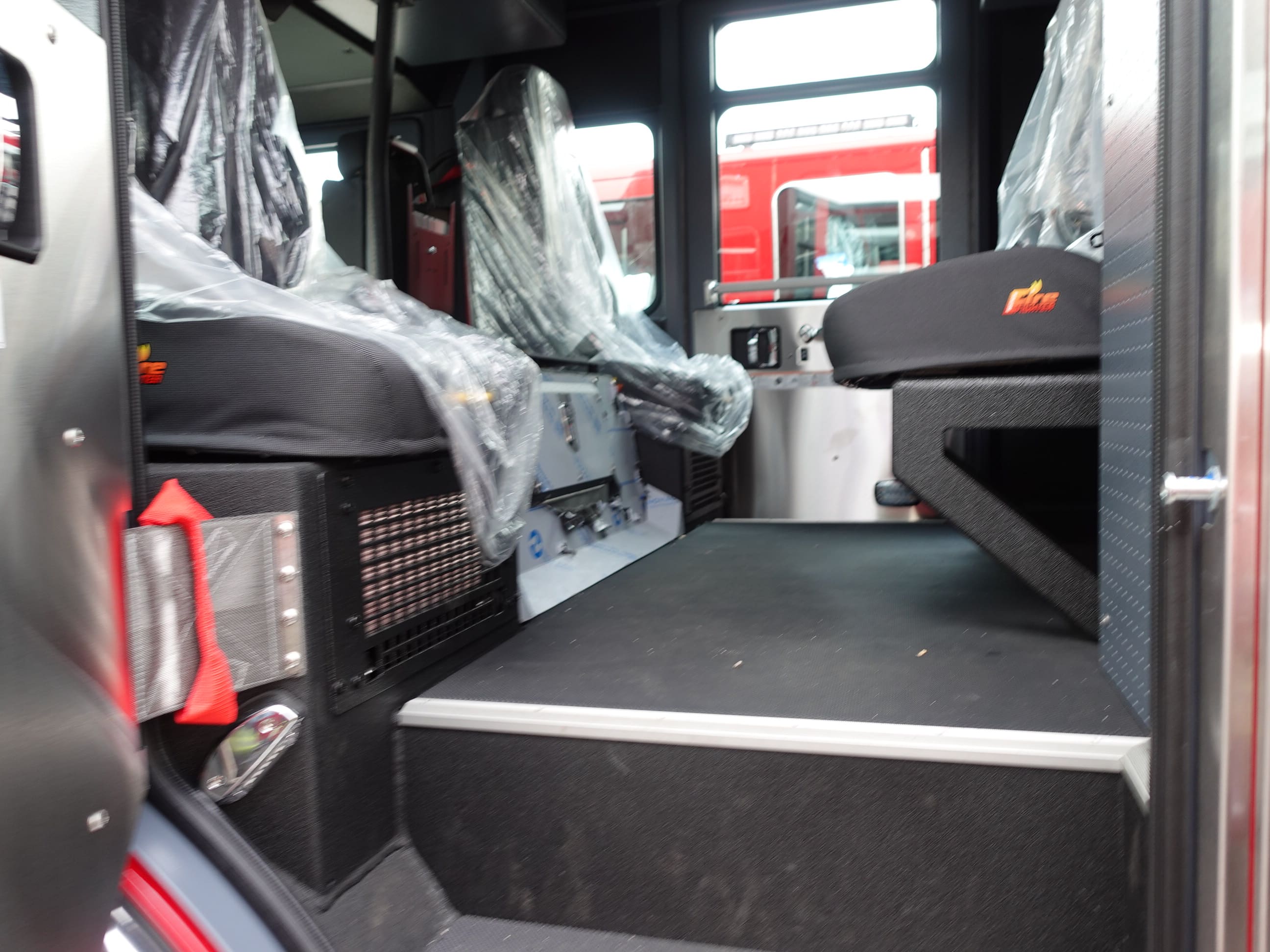

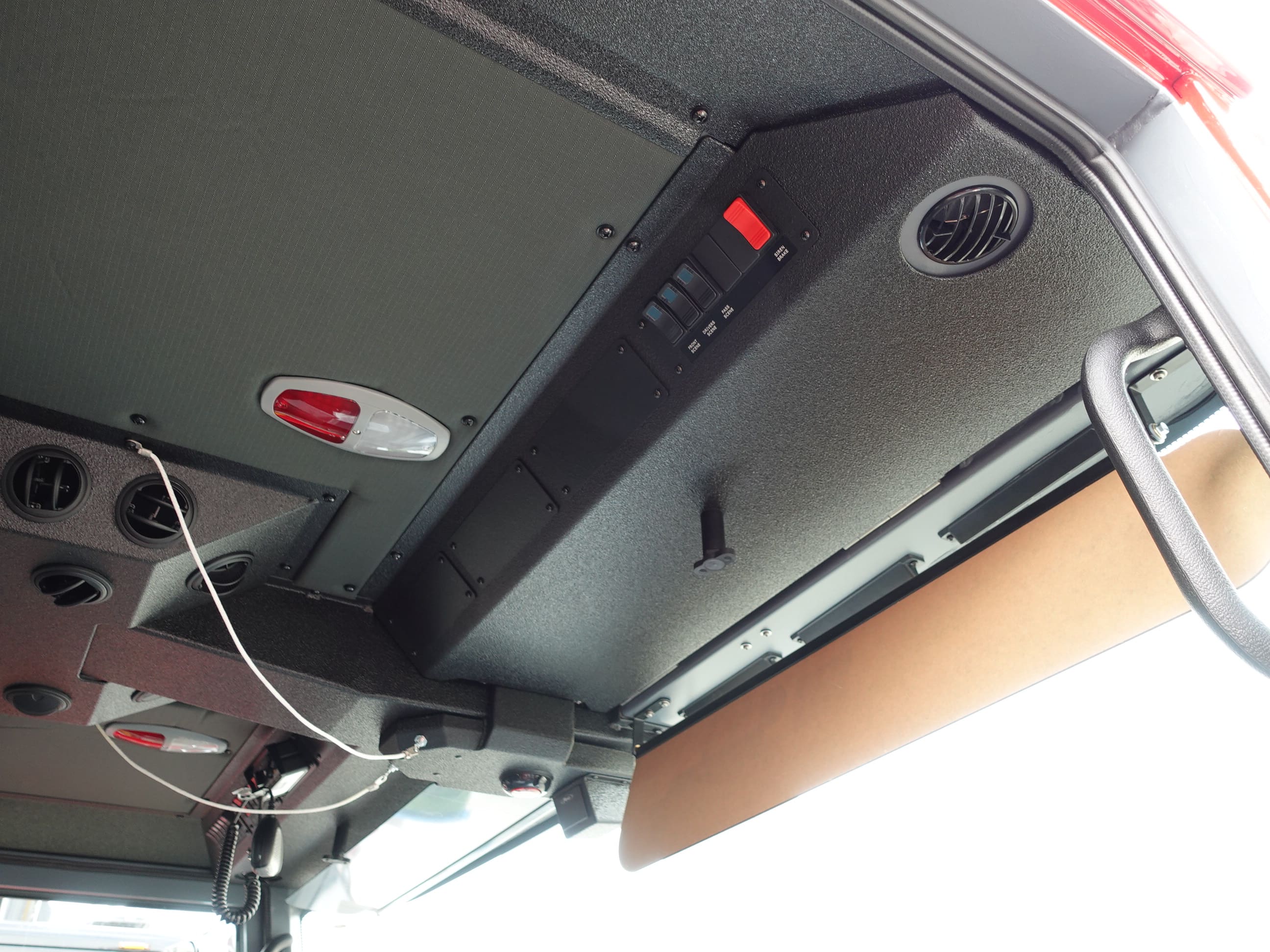

06-12-26

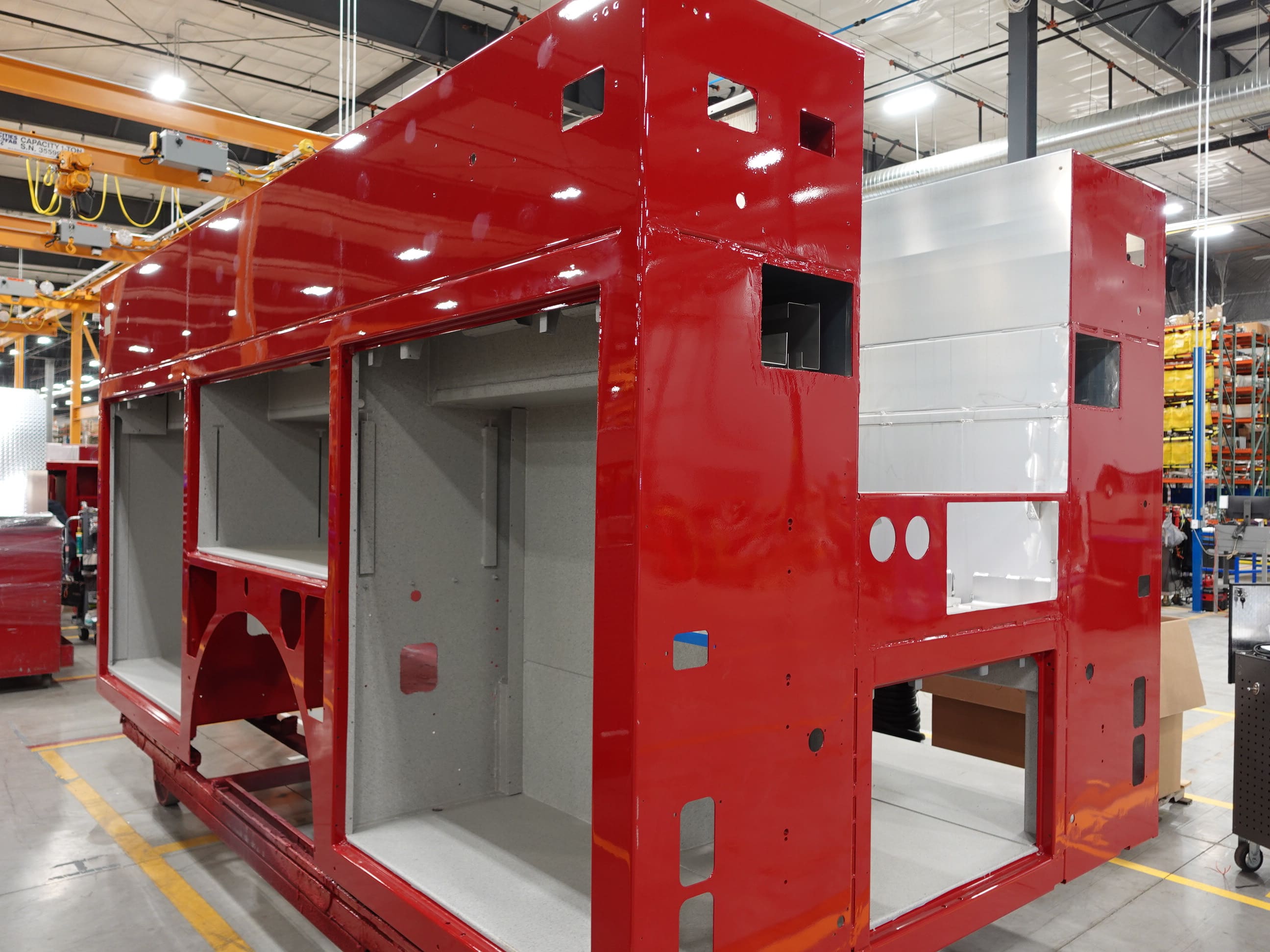

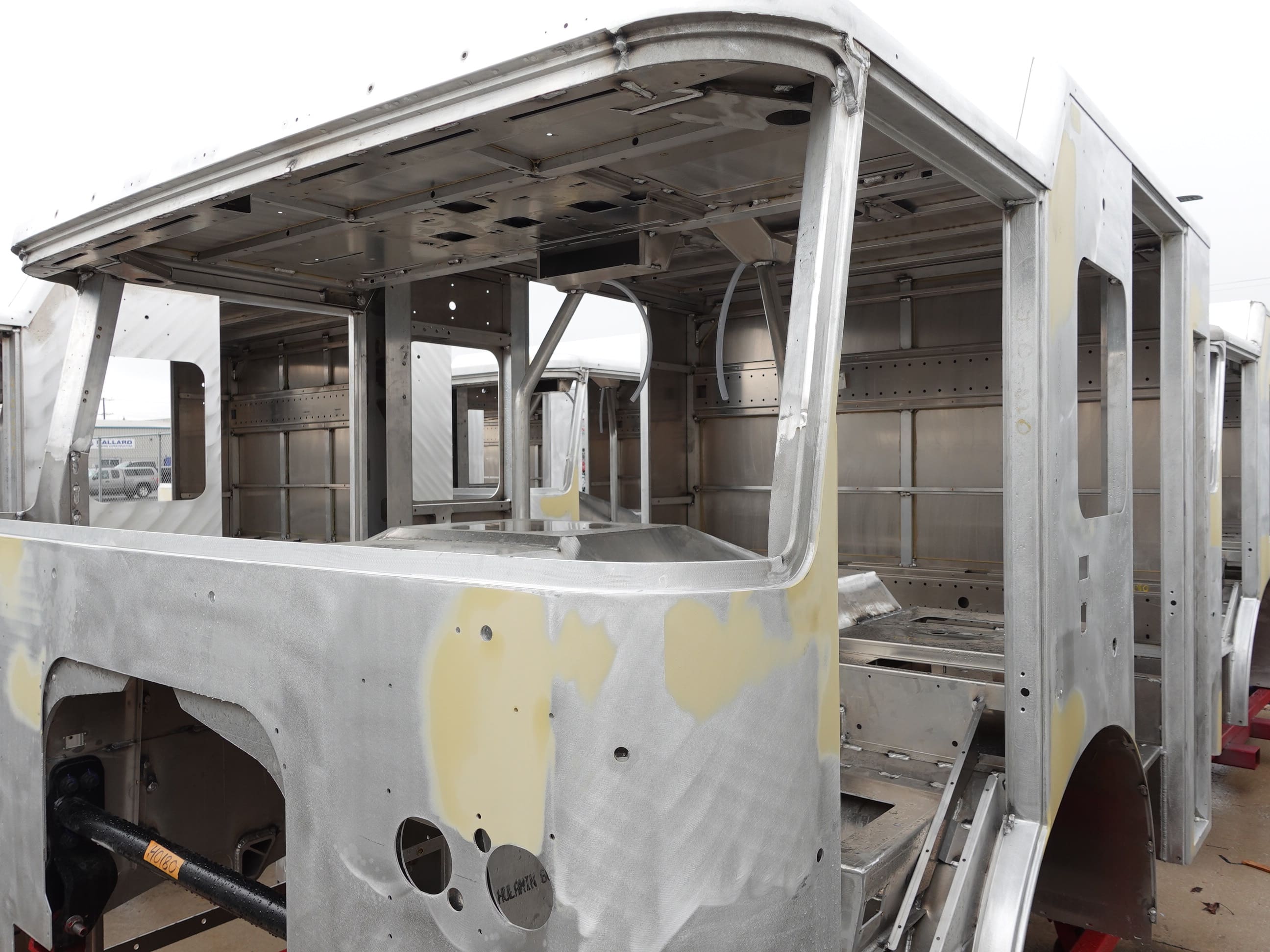

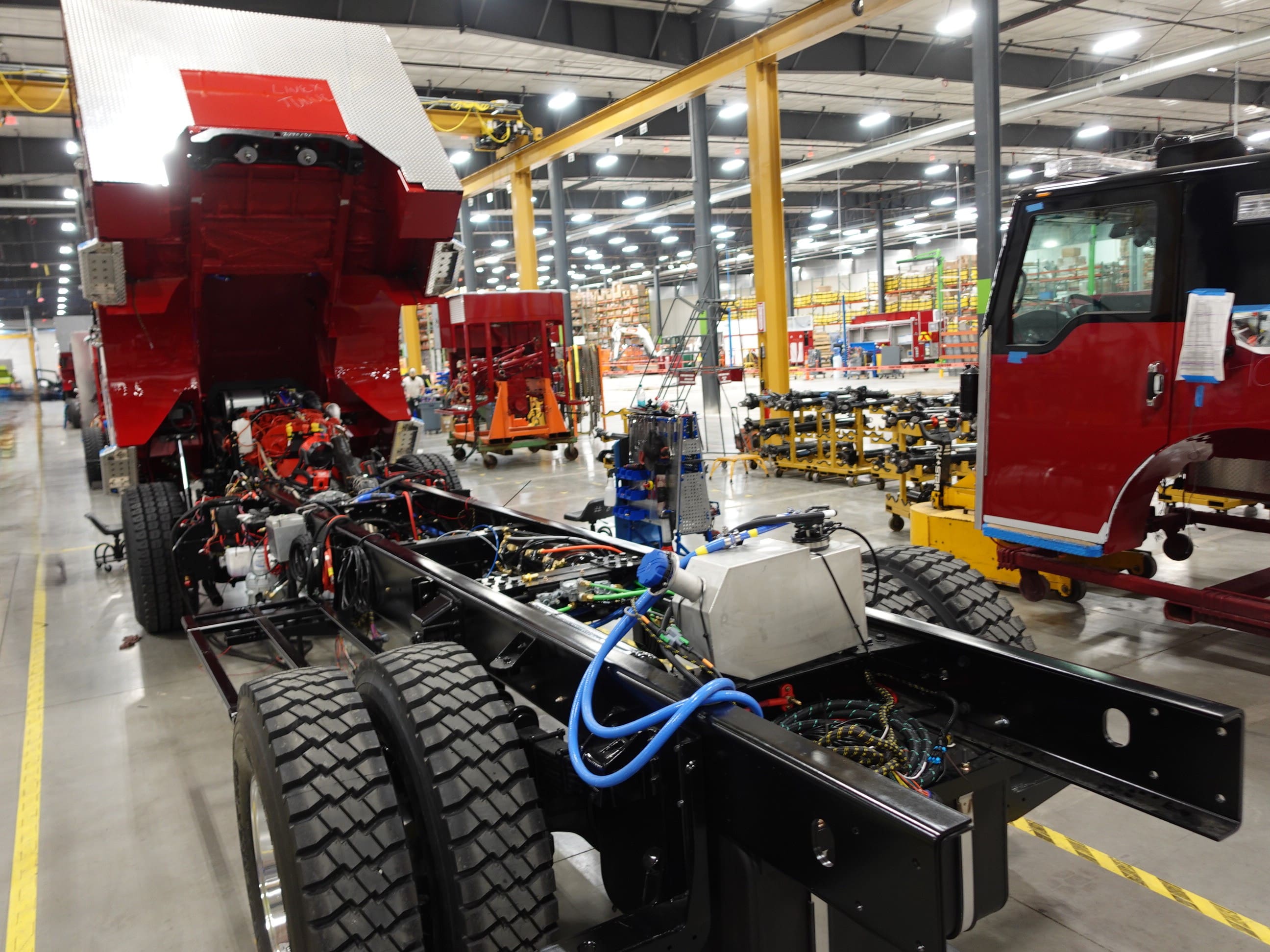

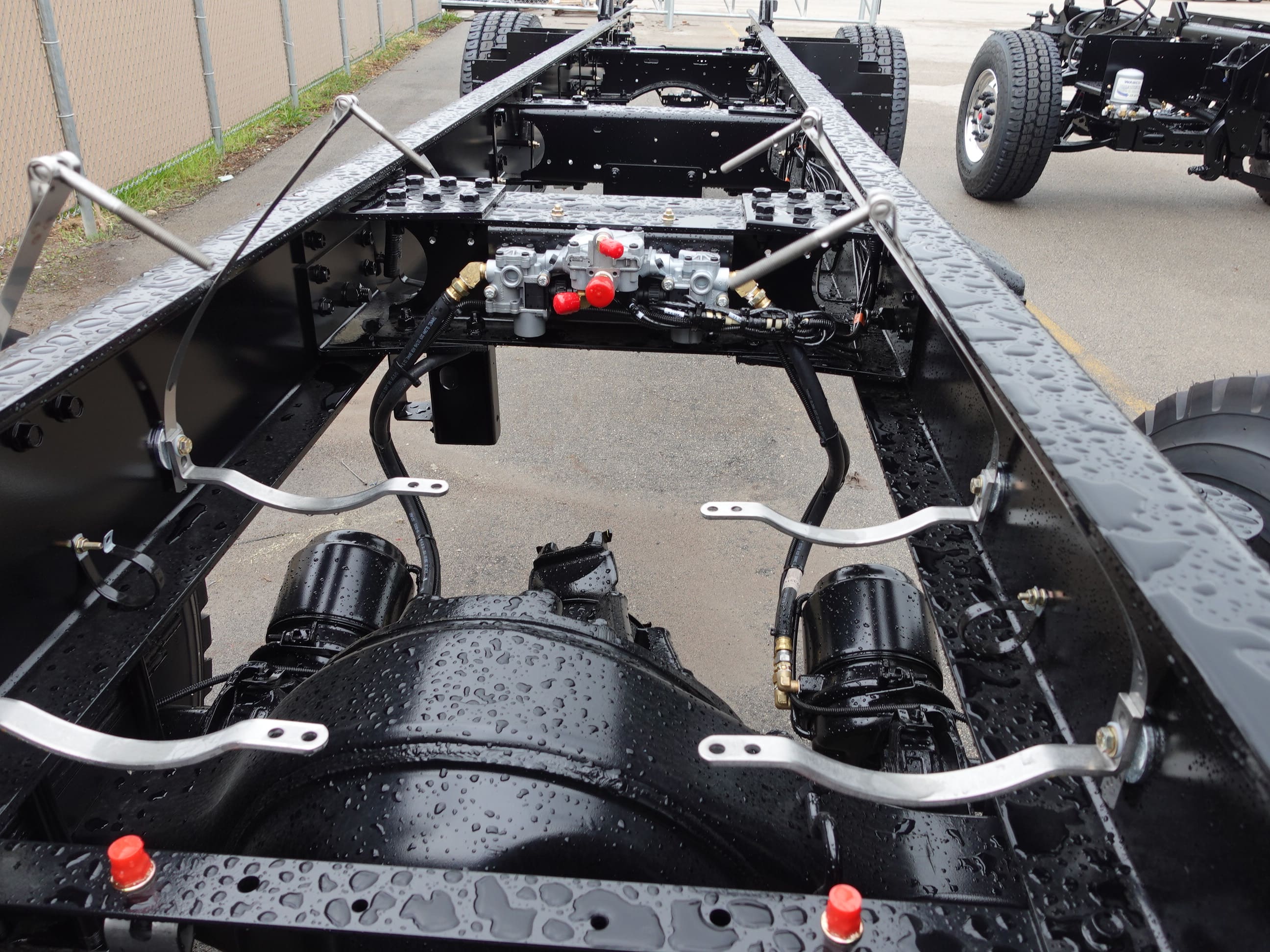

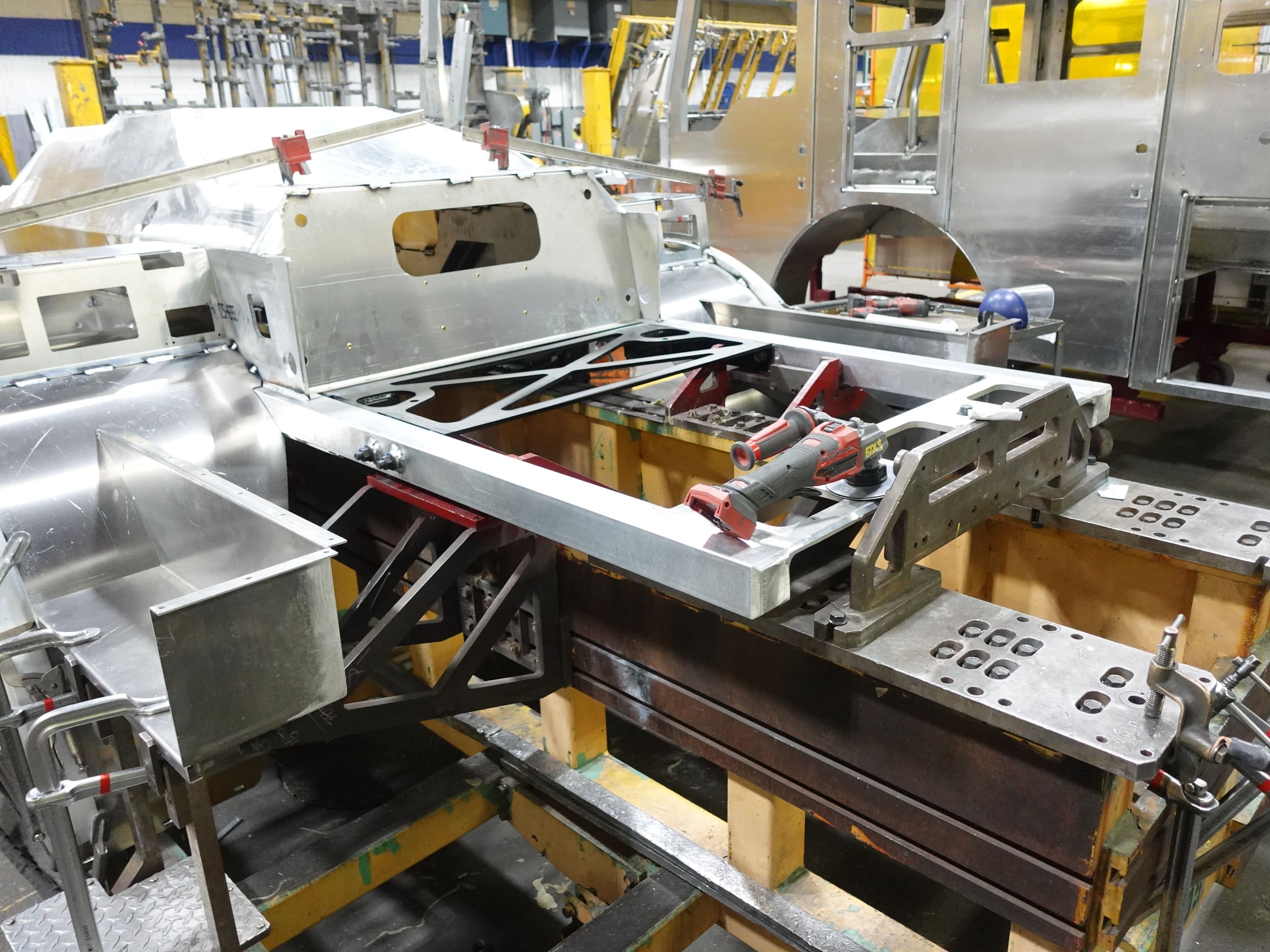

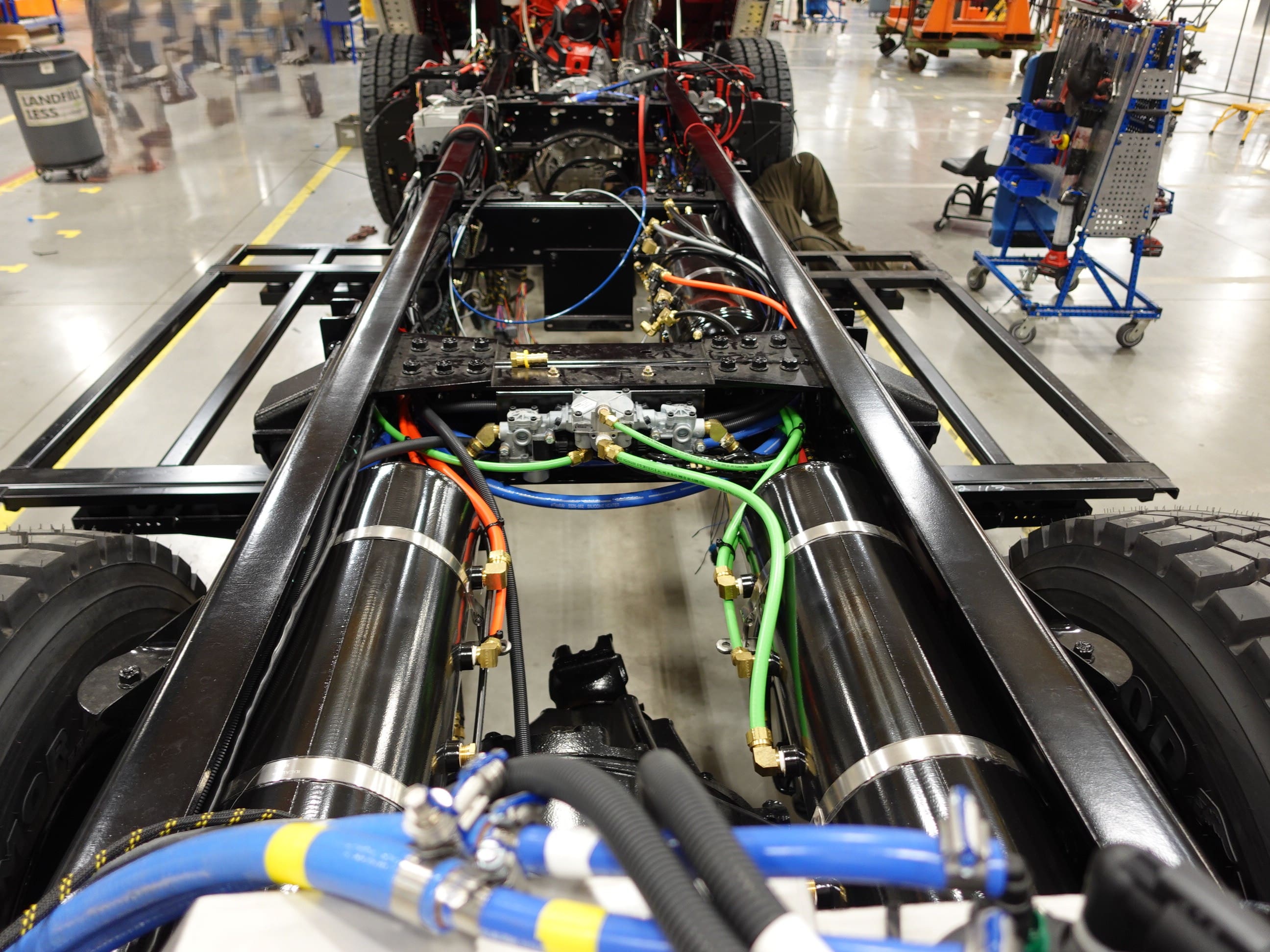

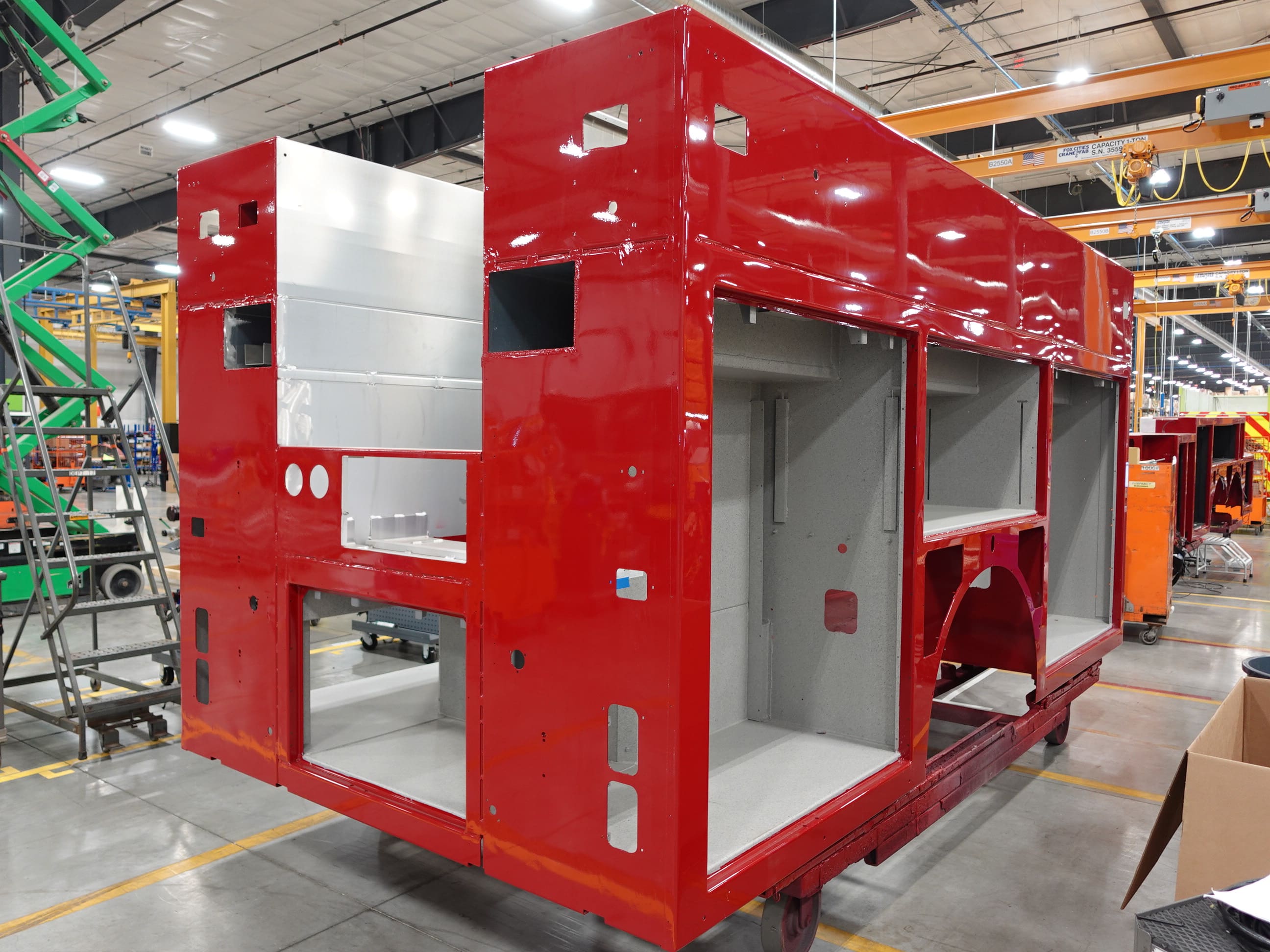

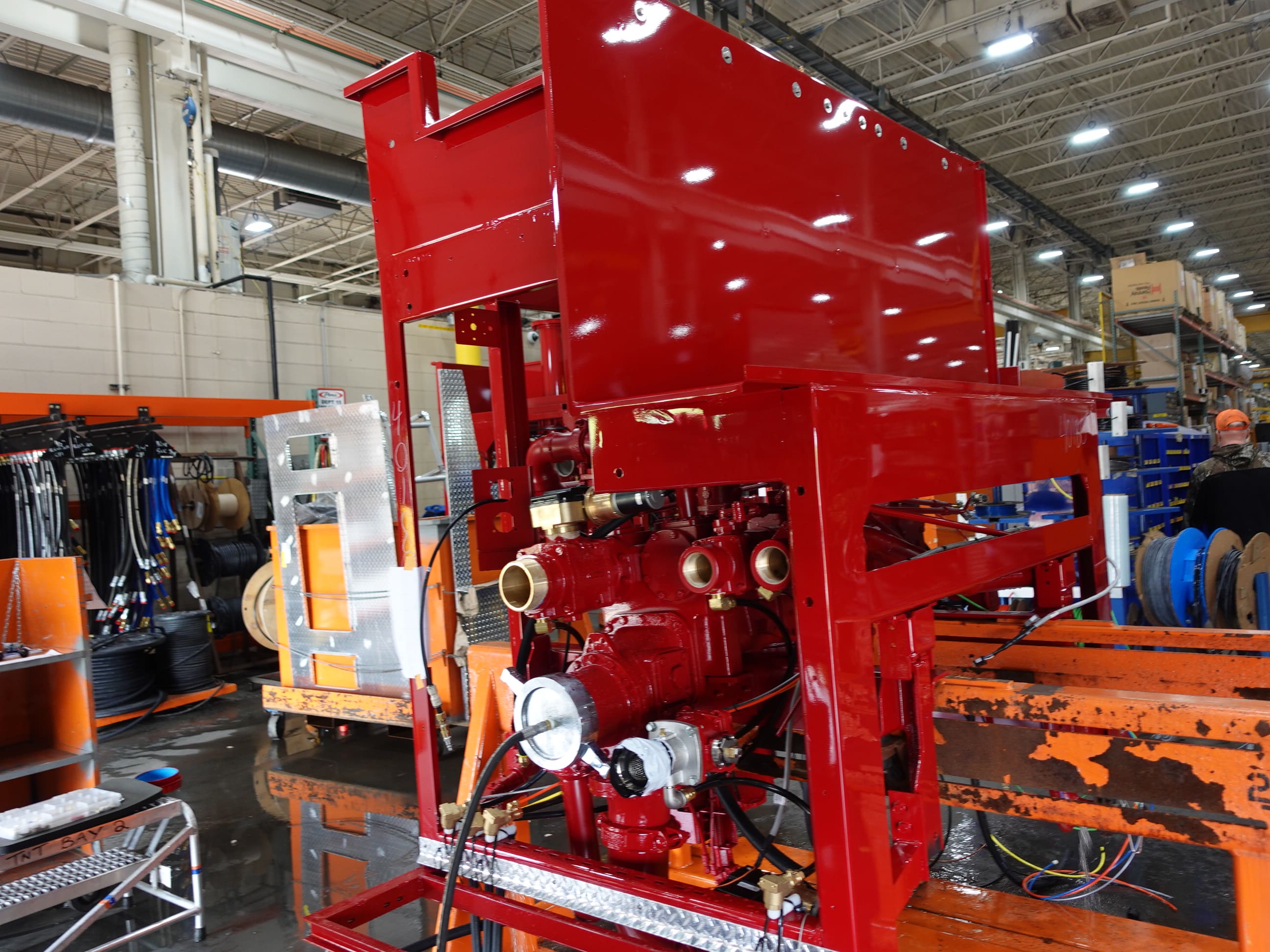

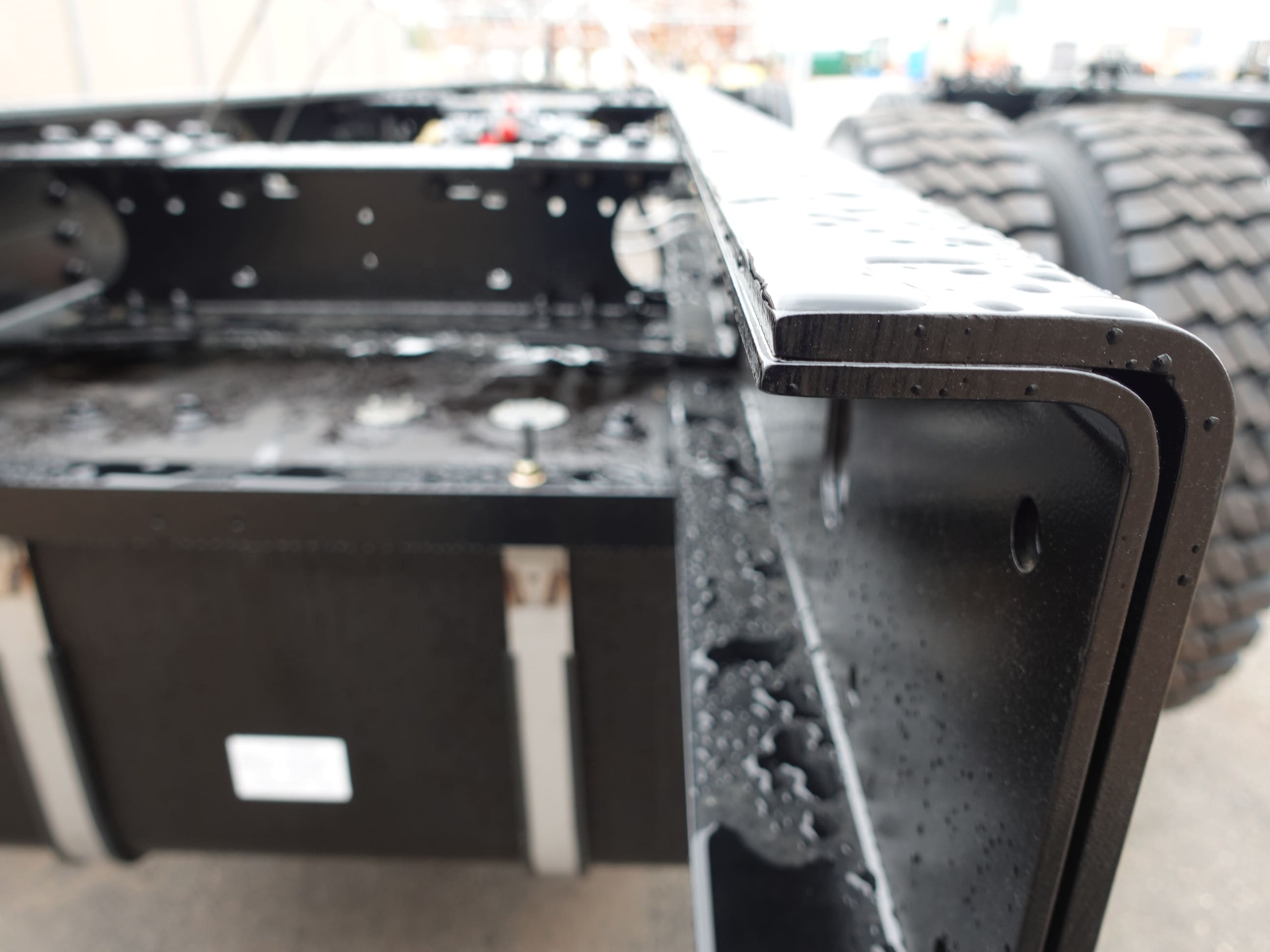

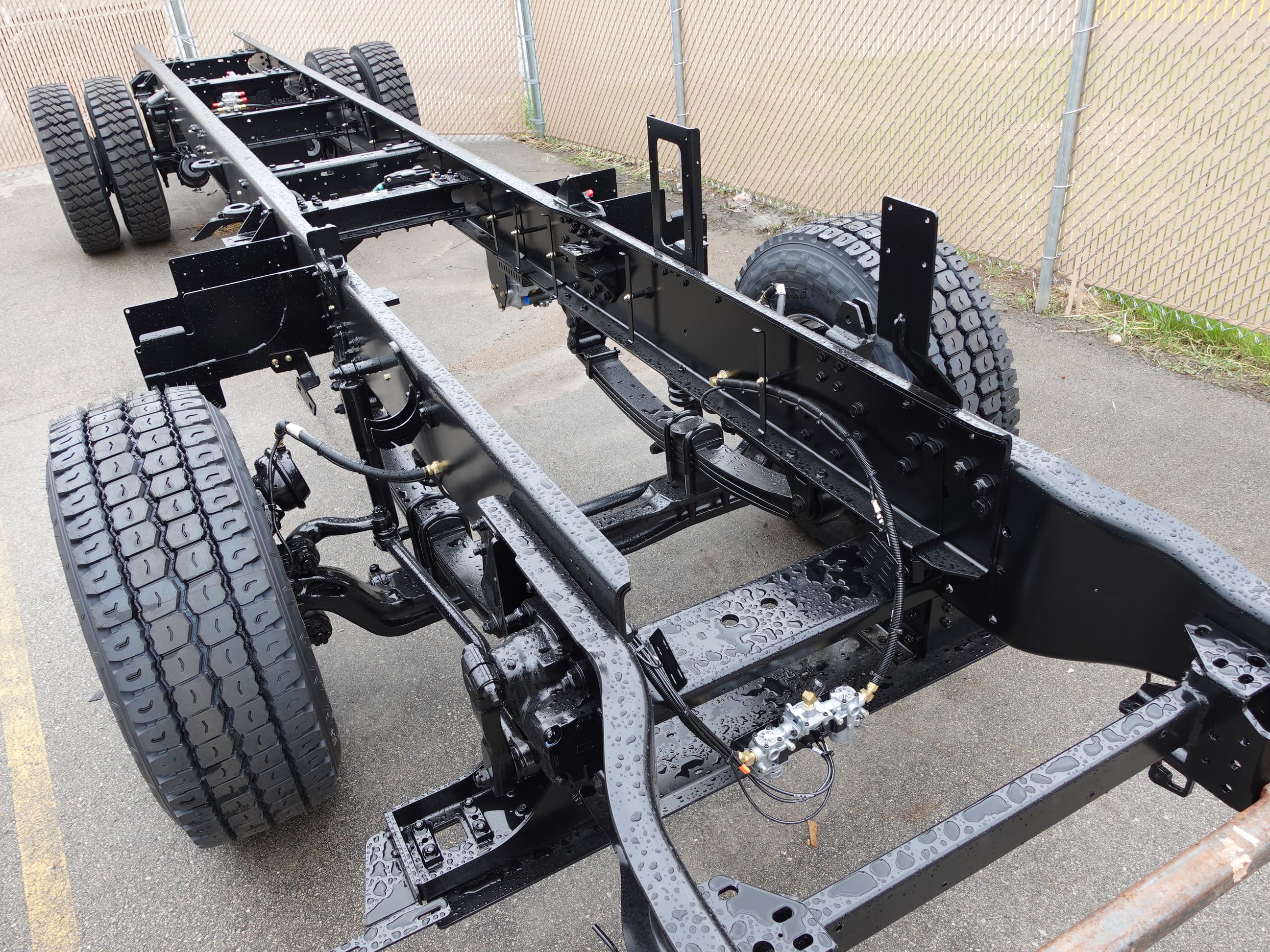

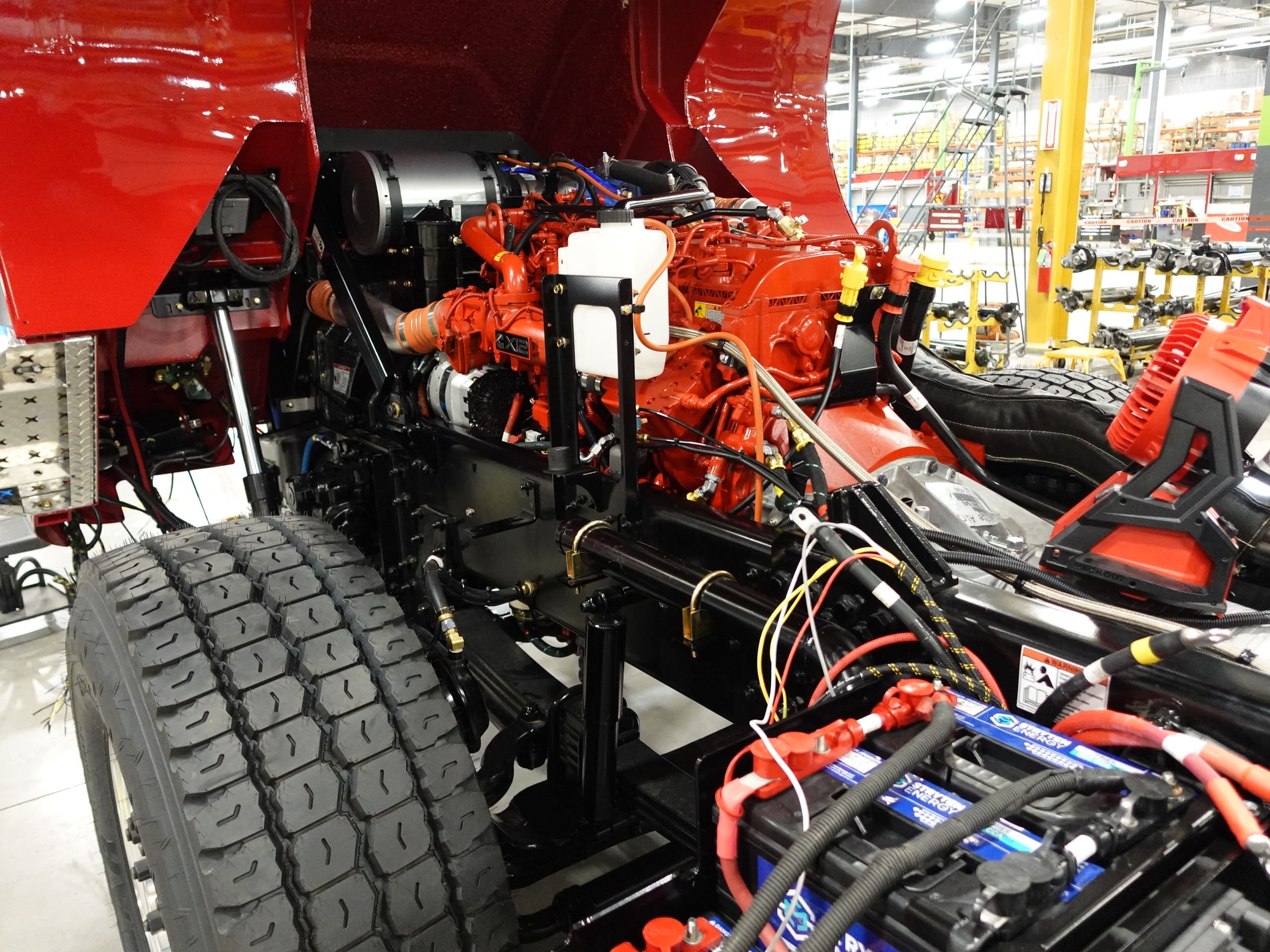

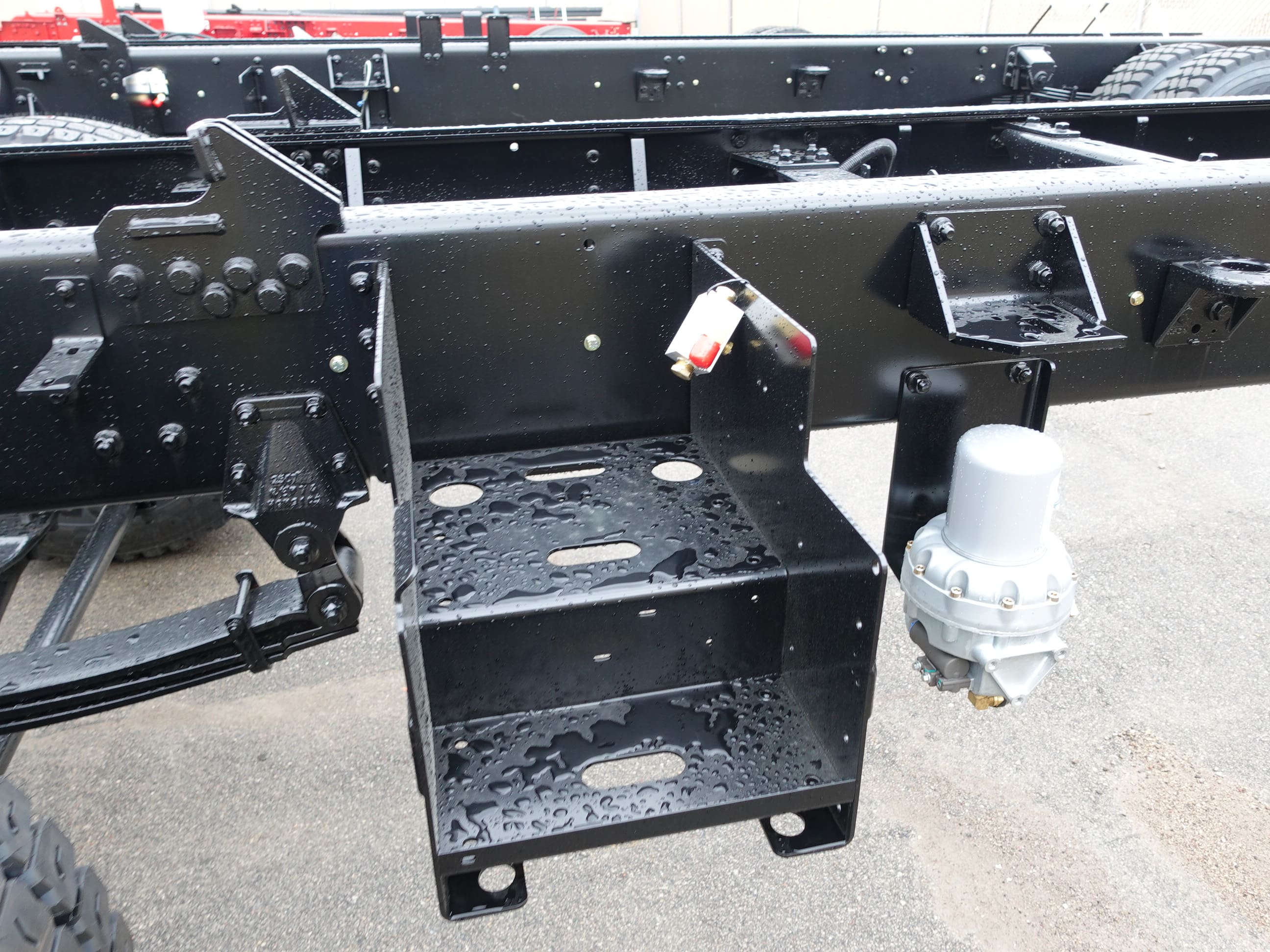

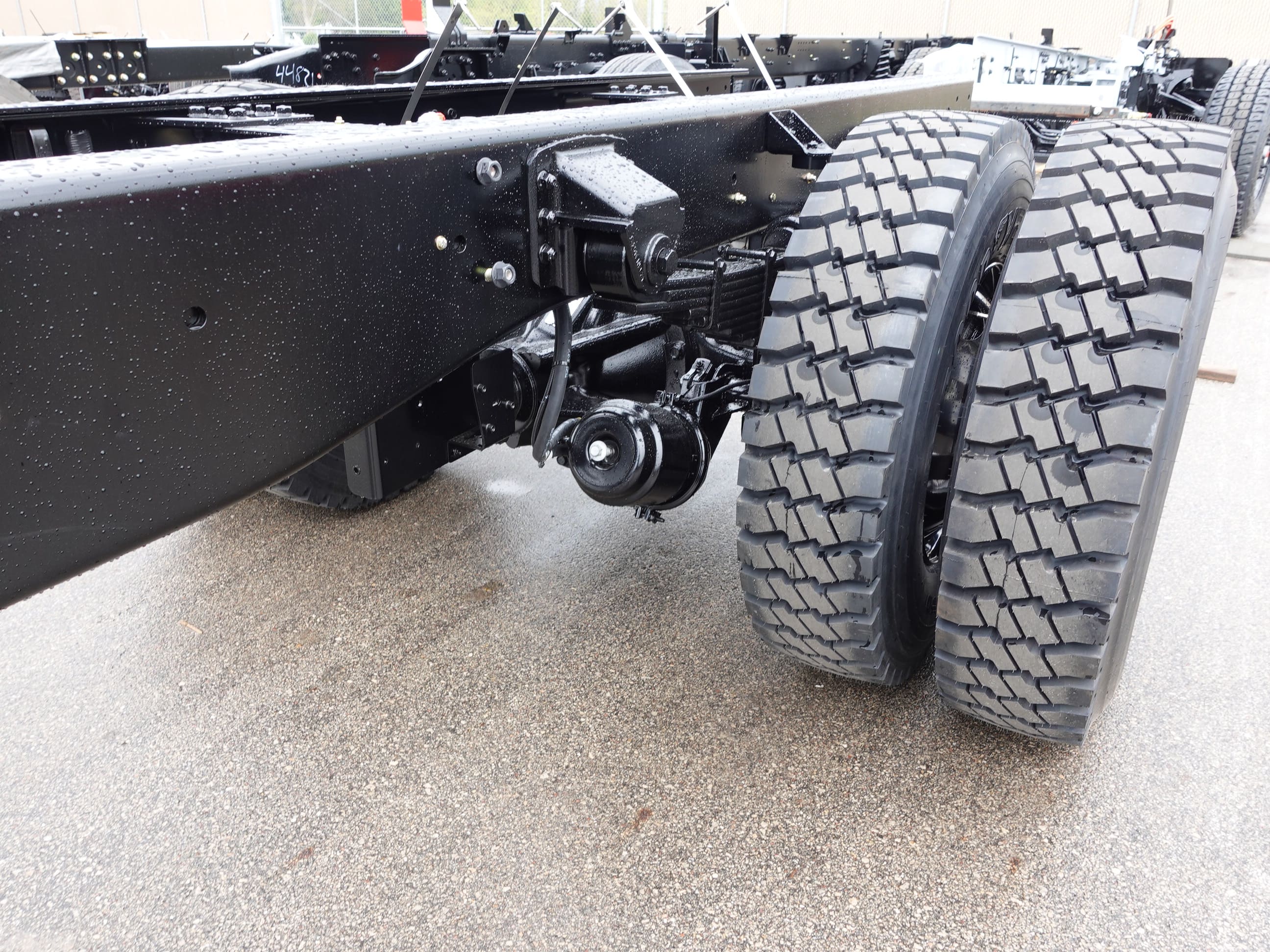

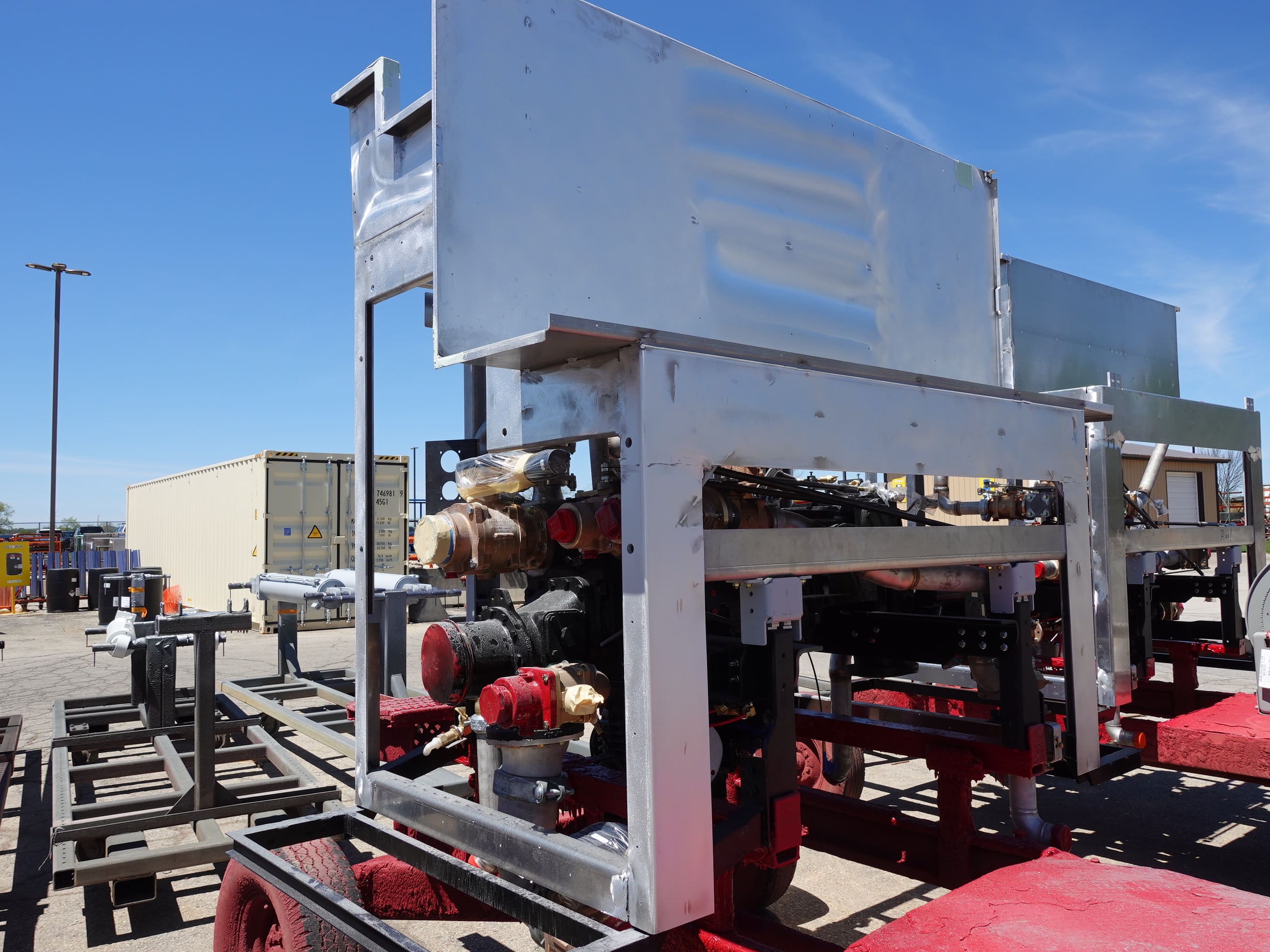

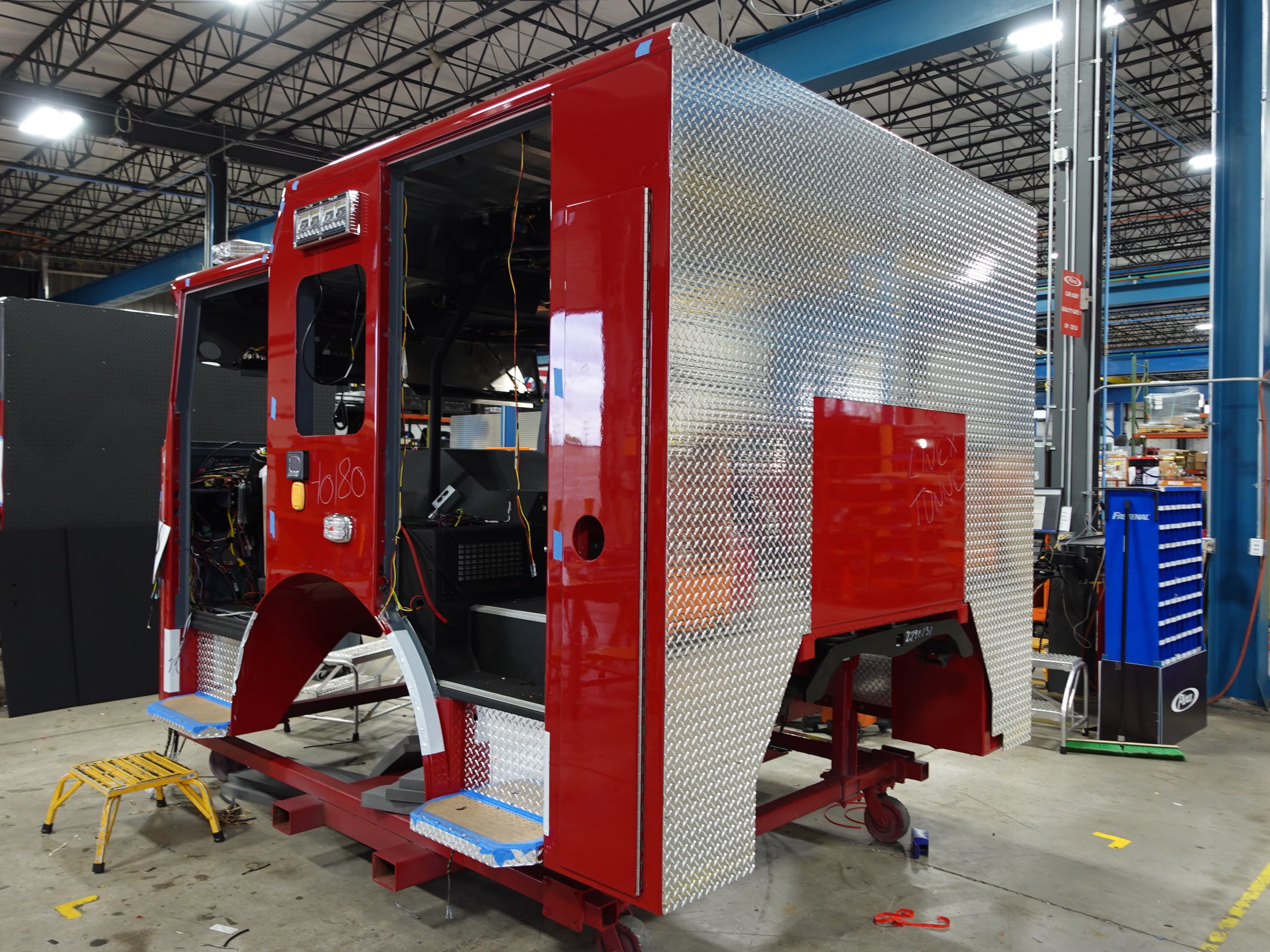

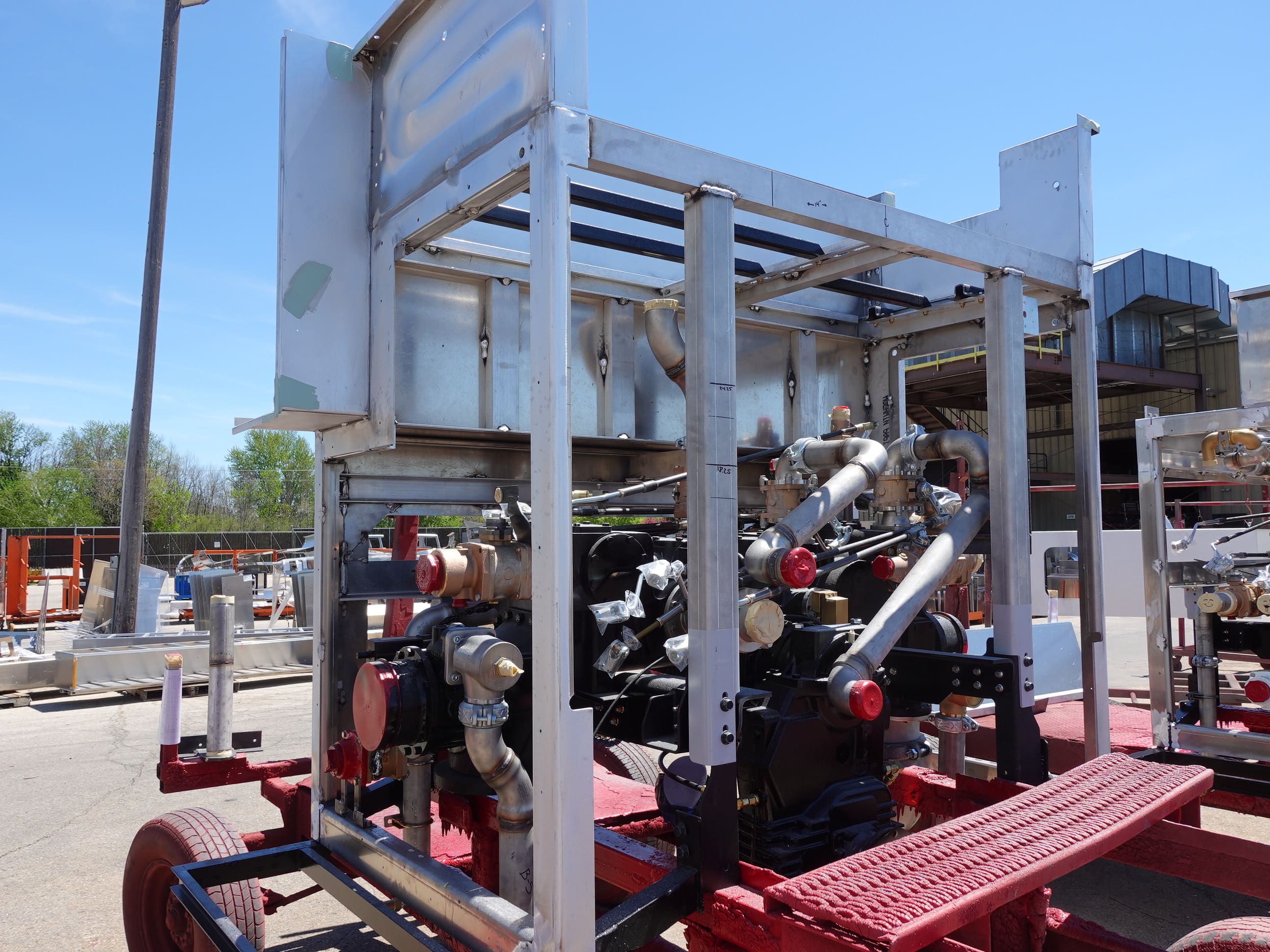

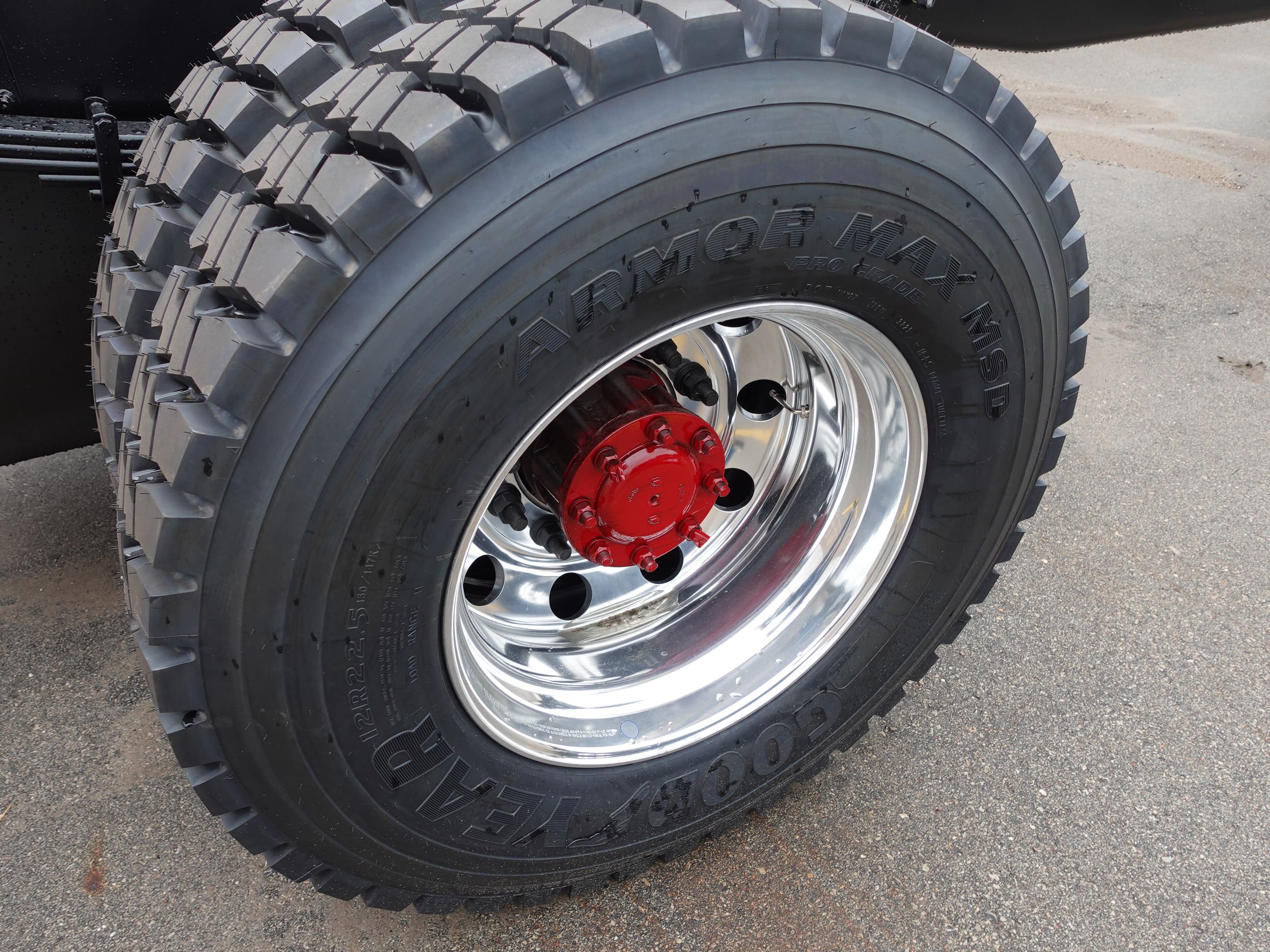

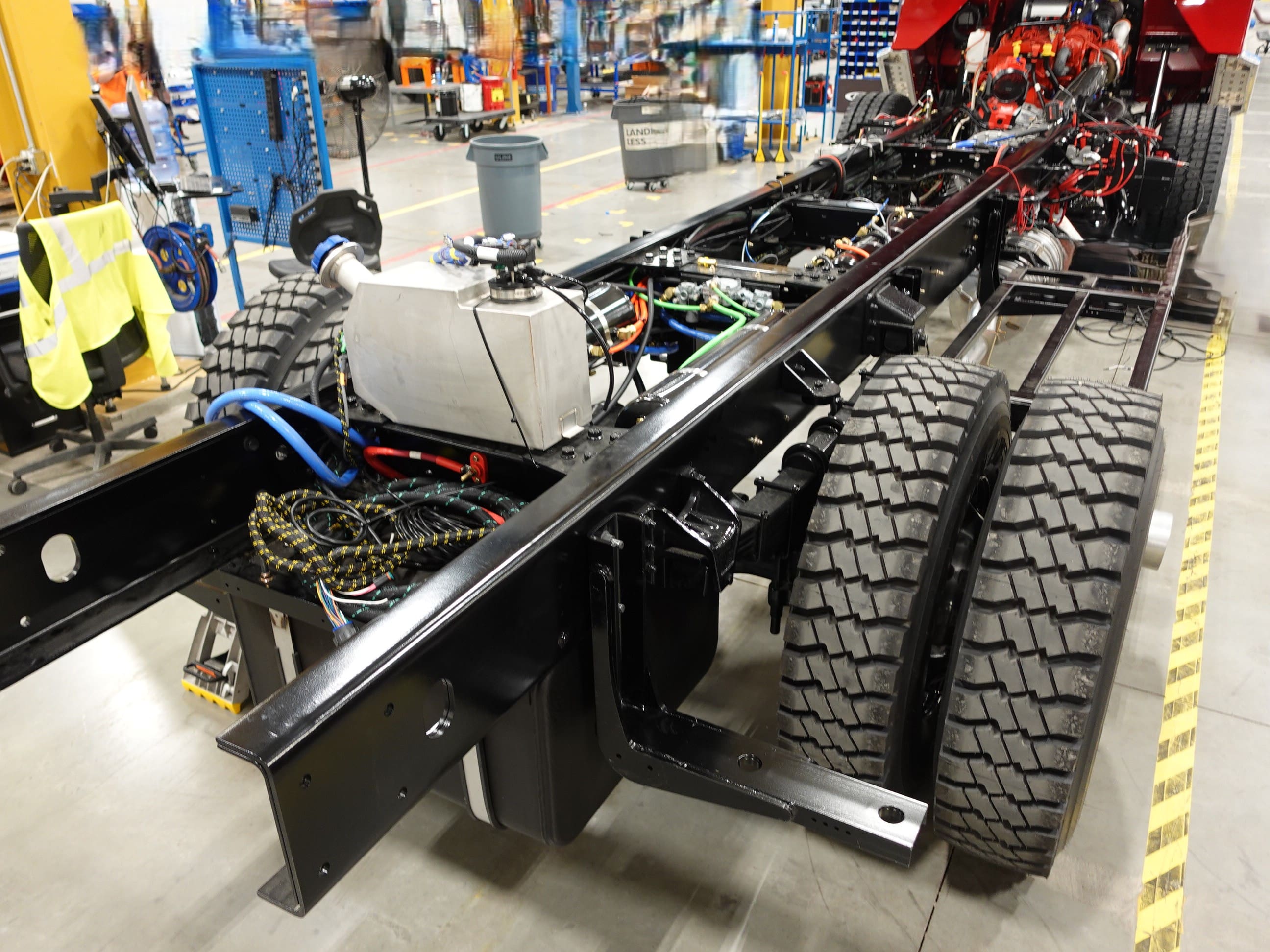

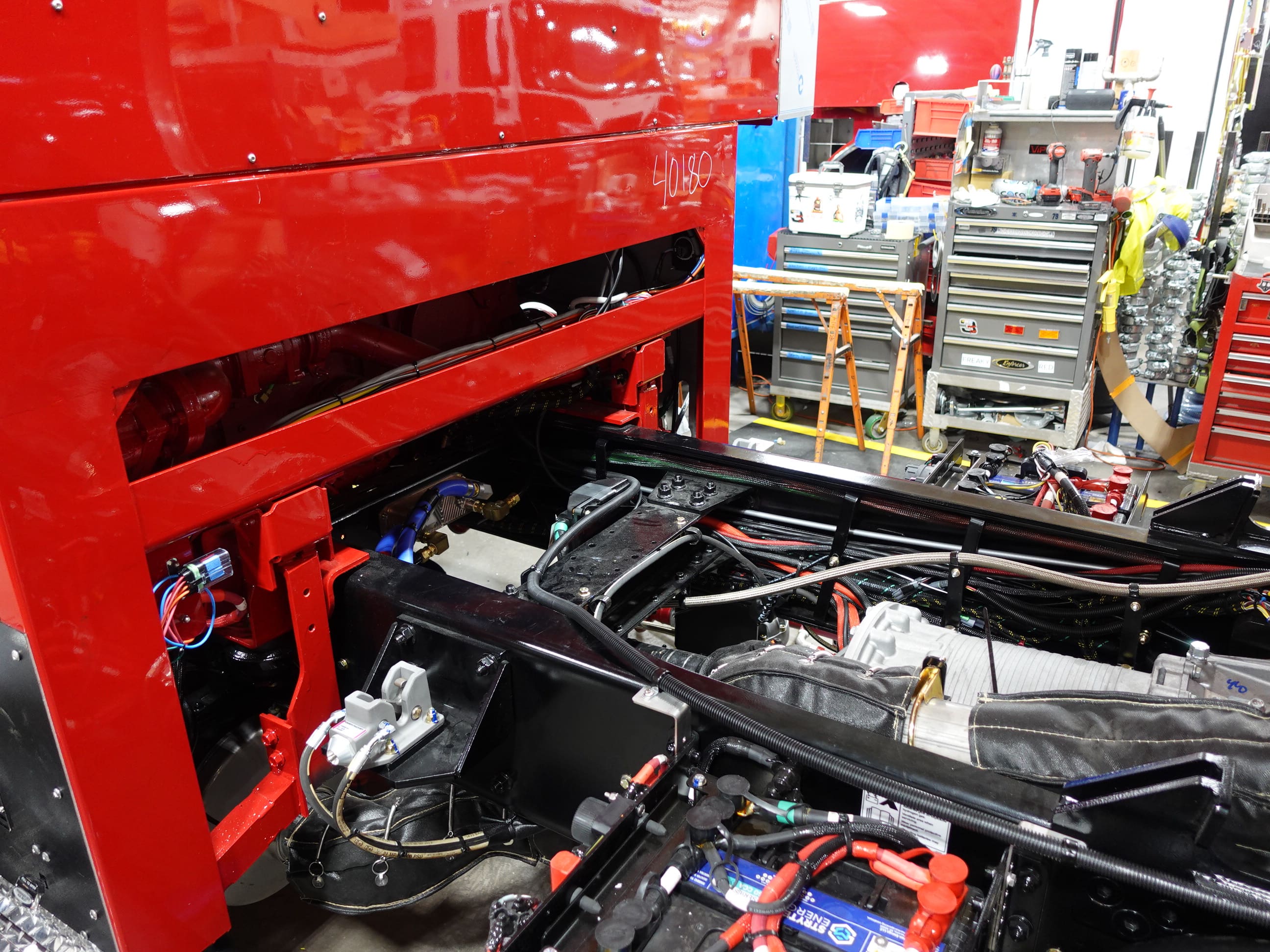

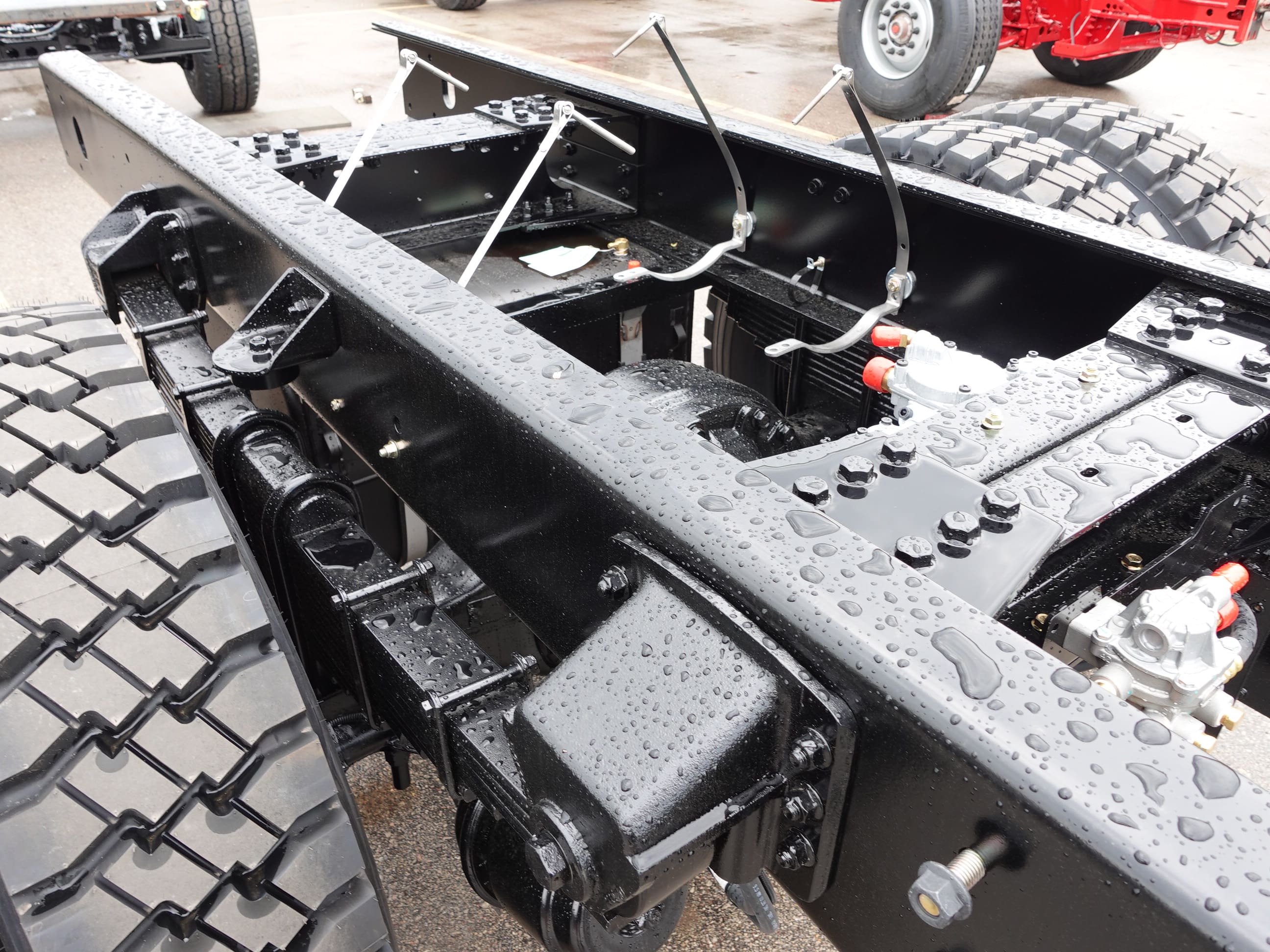

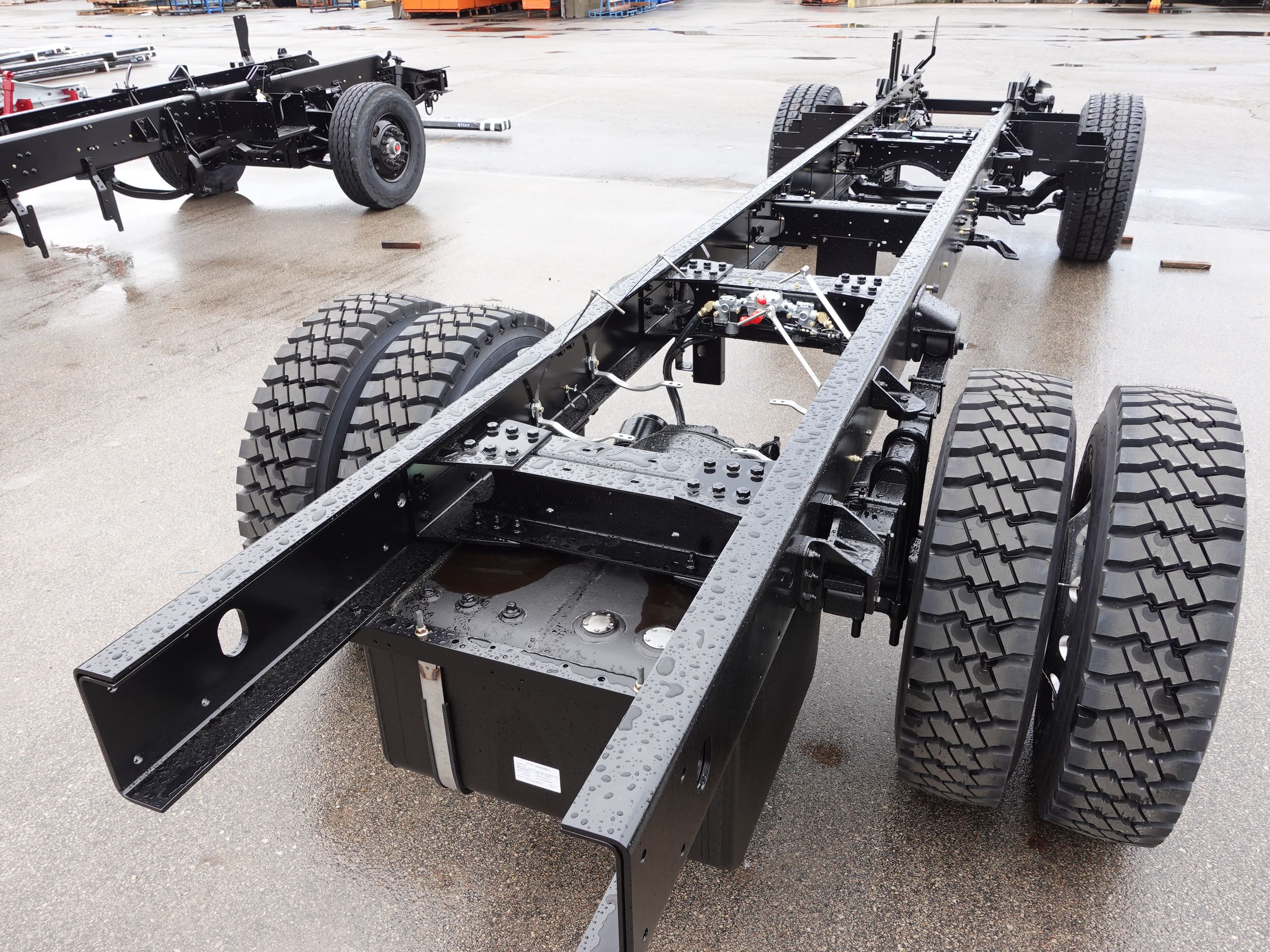

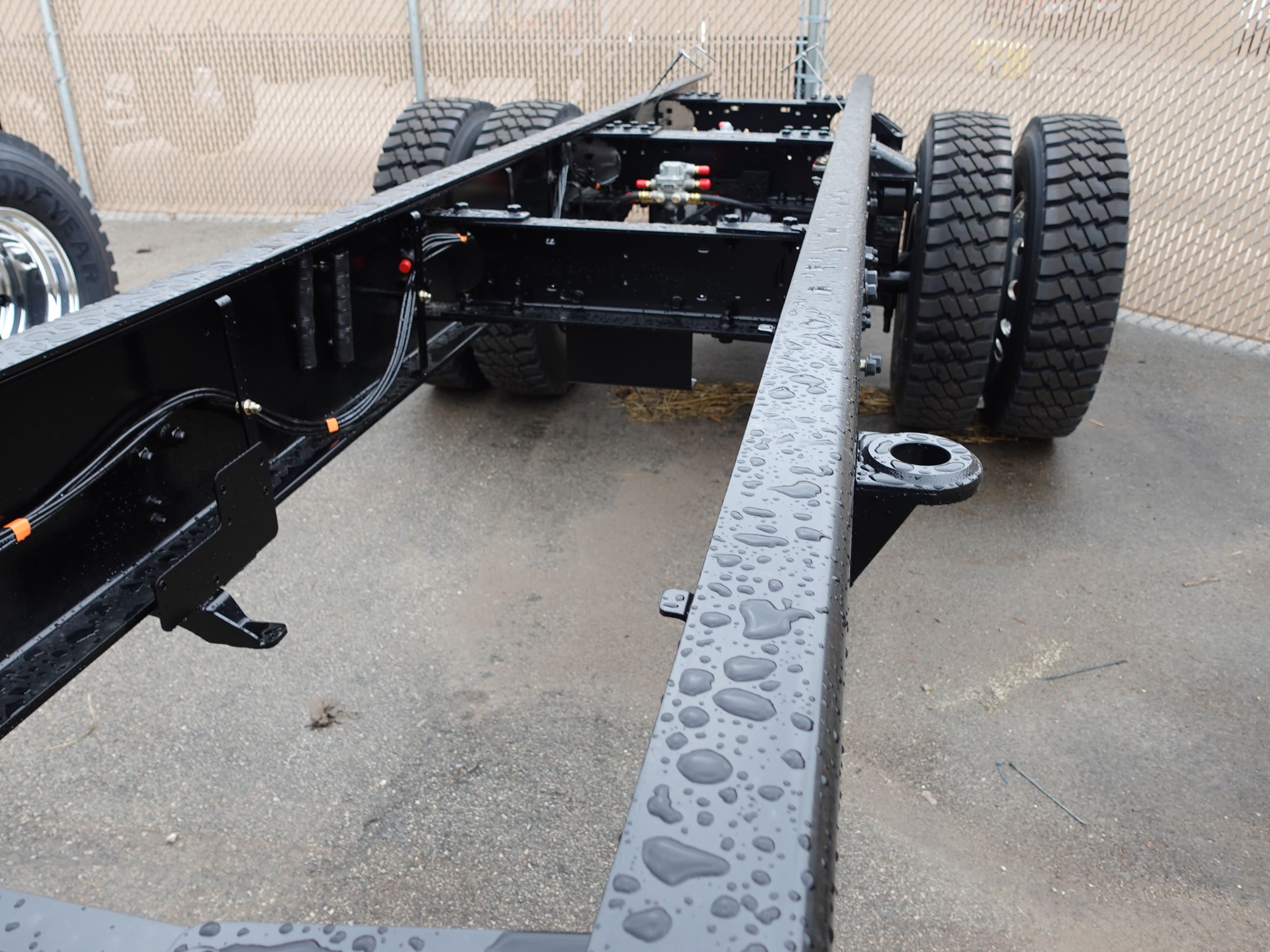

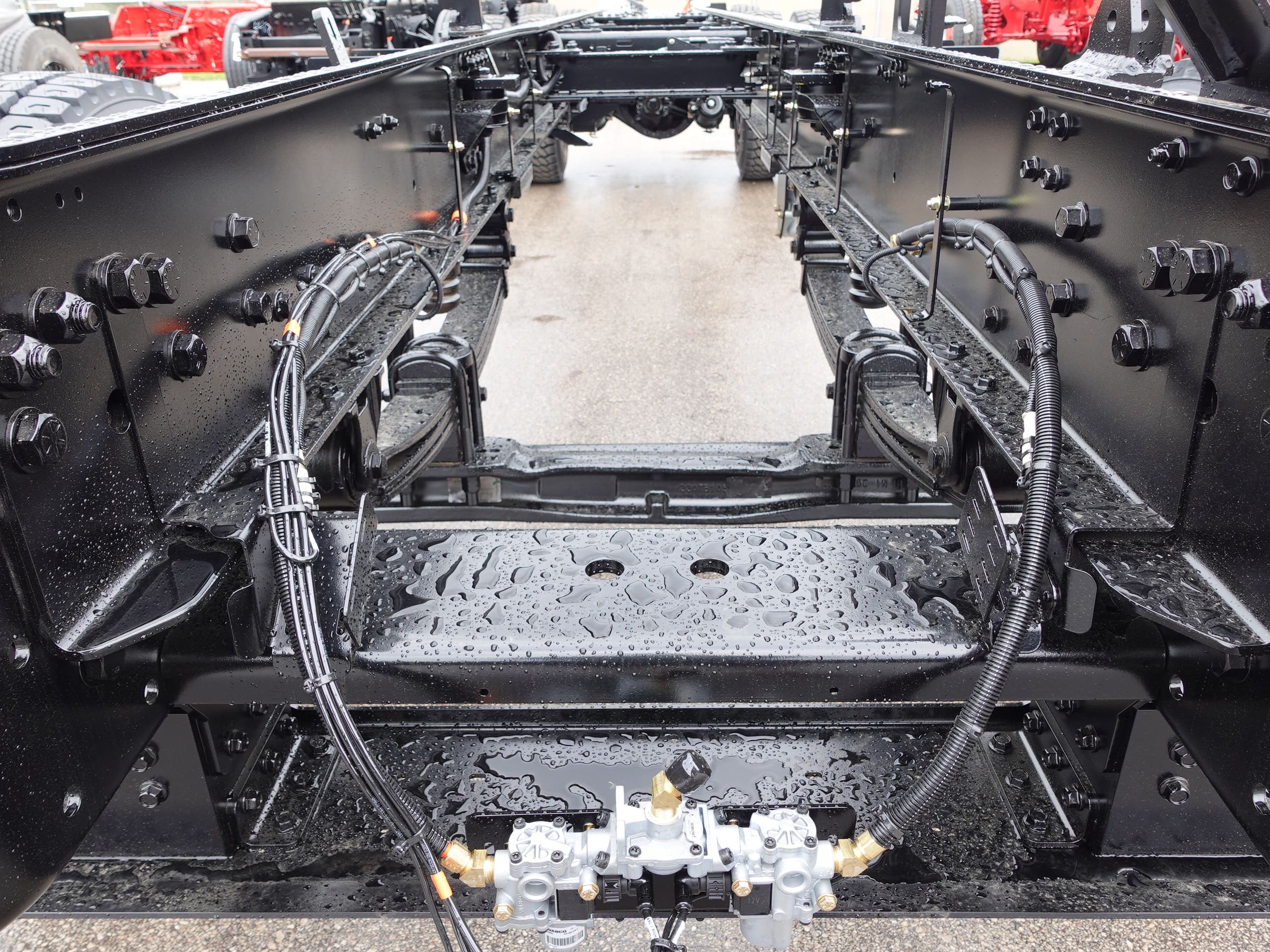

In this report, the pump house and body were merged with

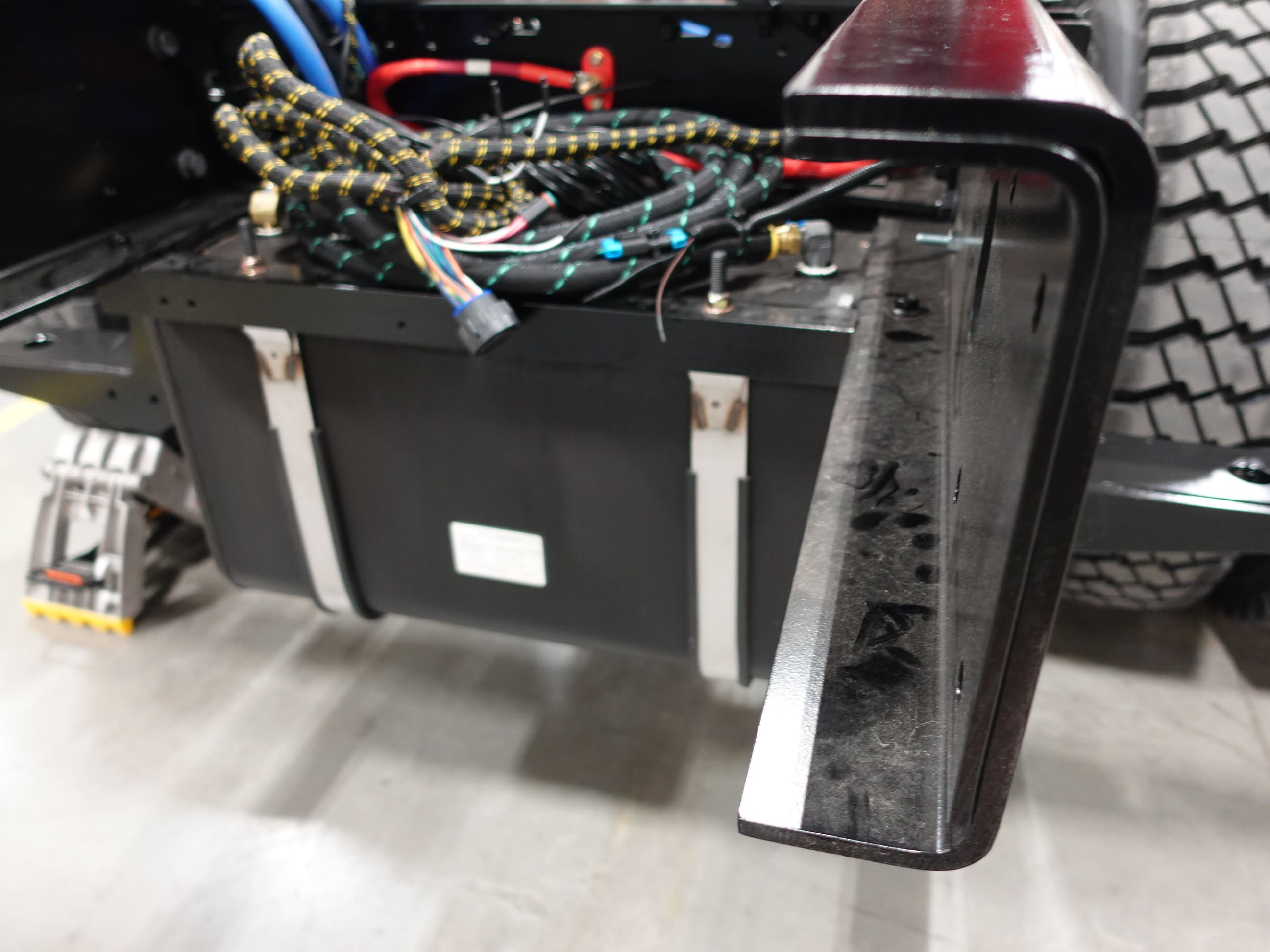

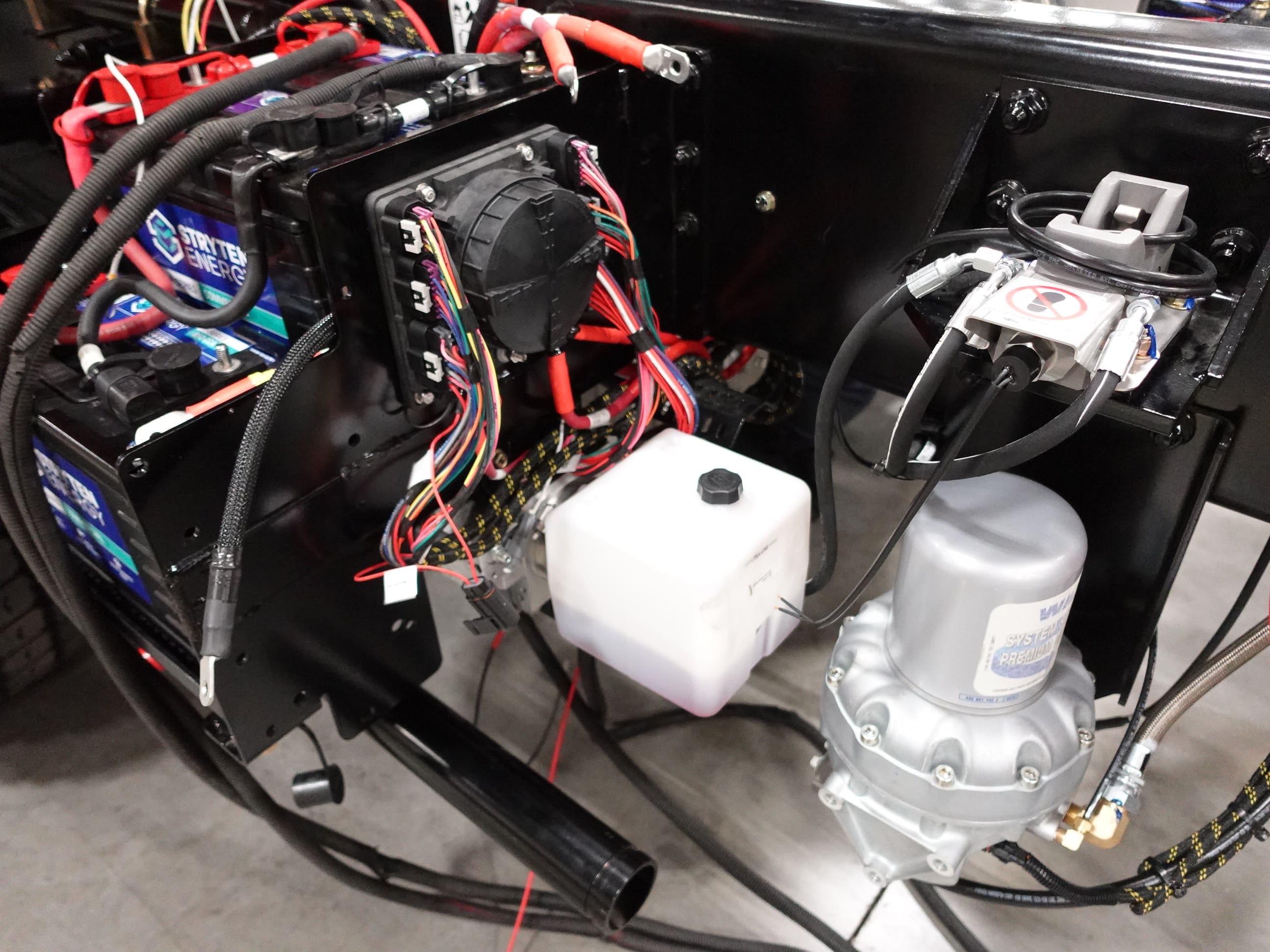

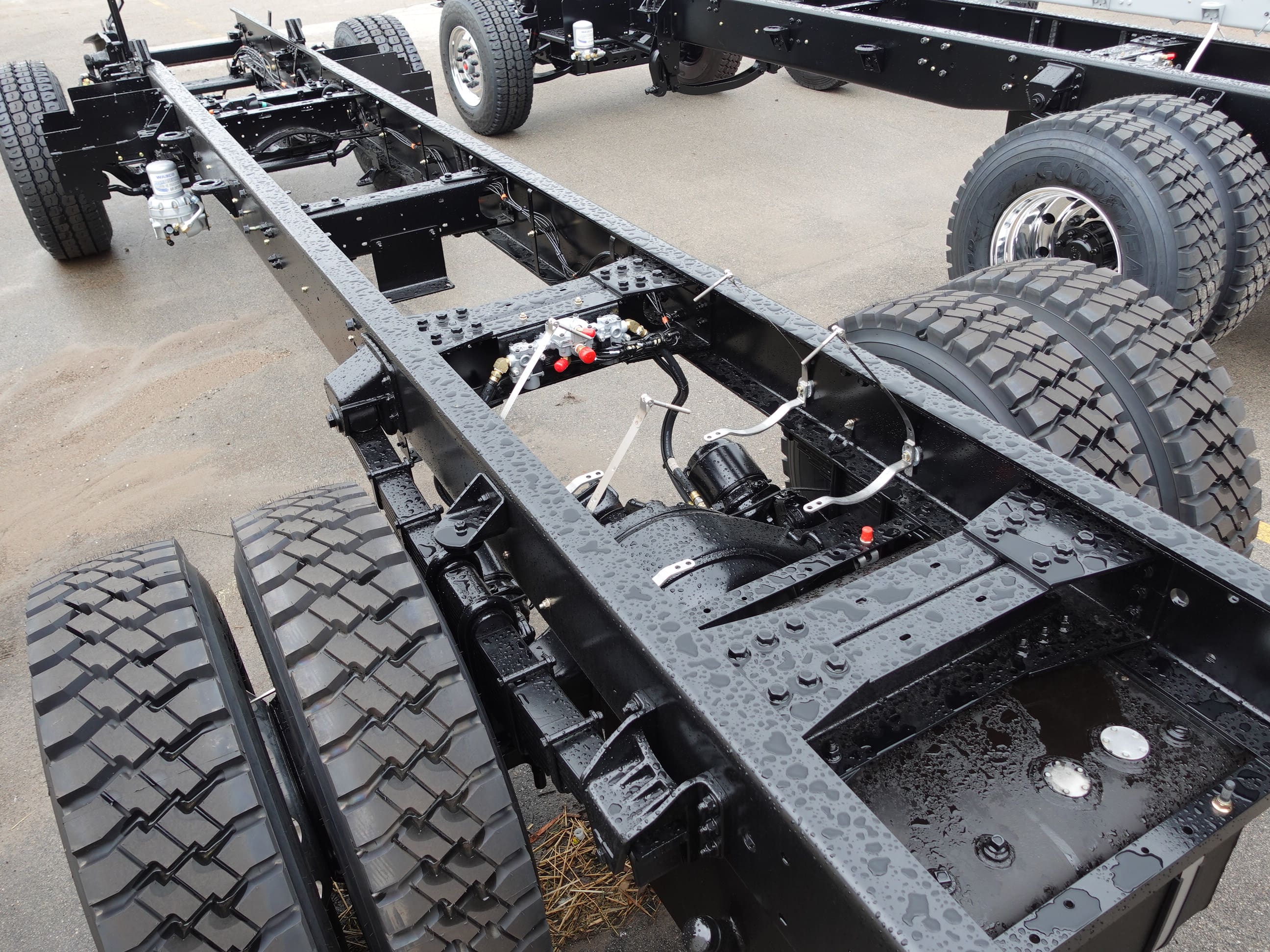

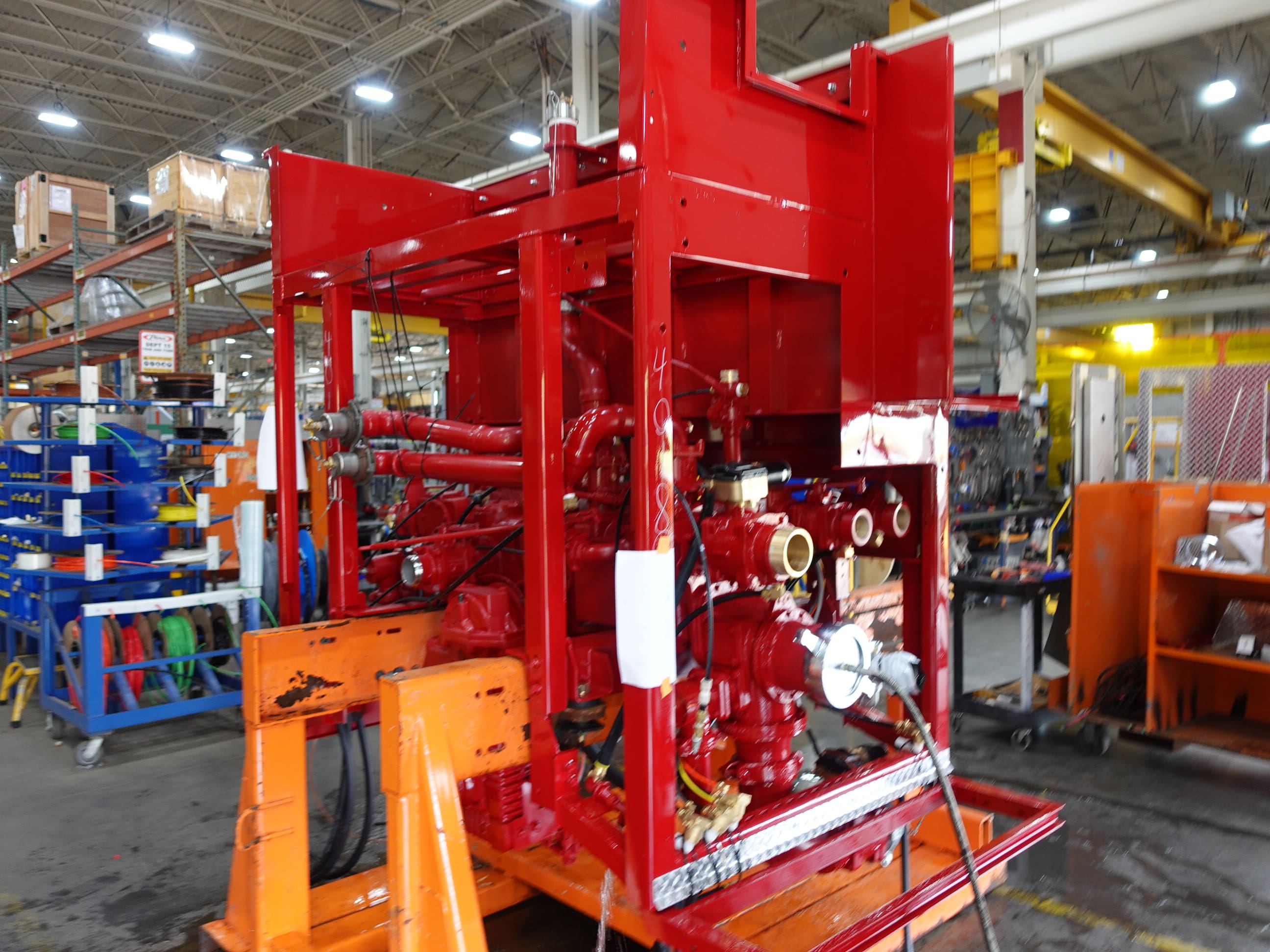

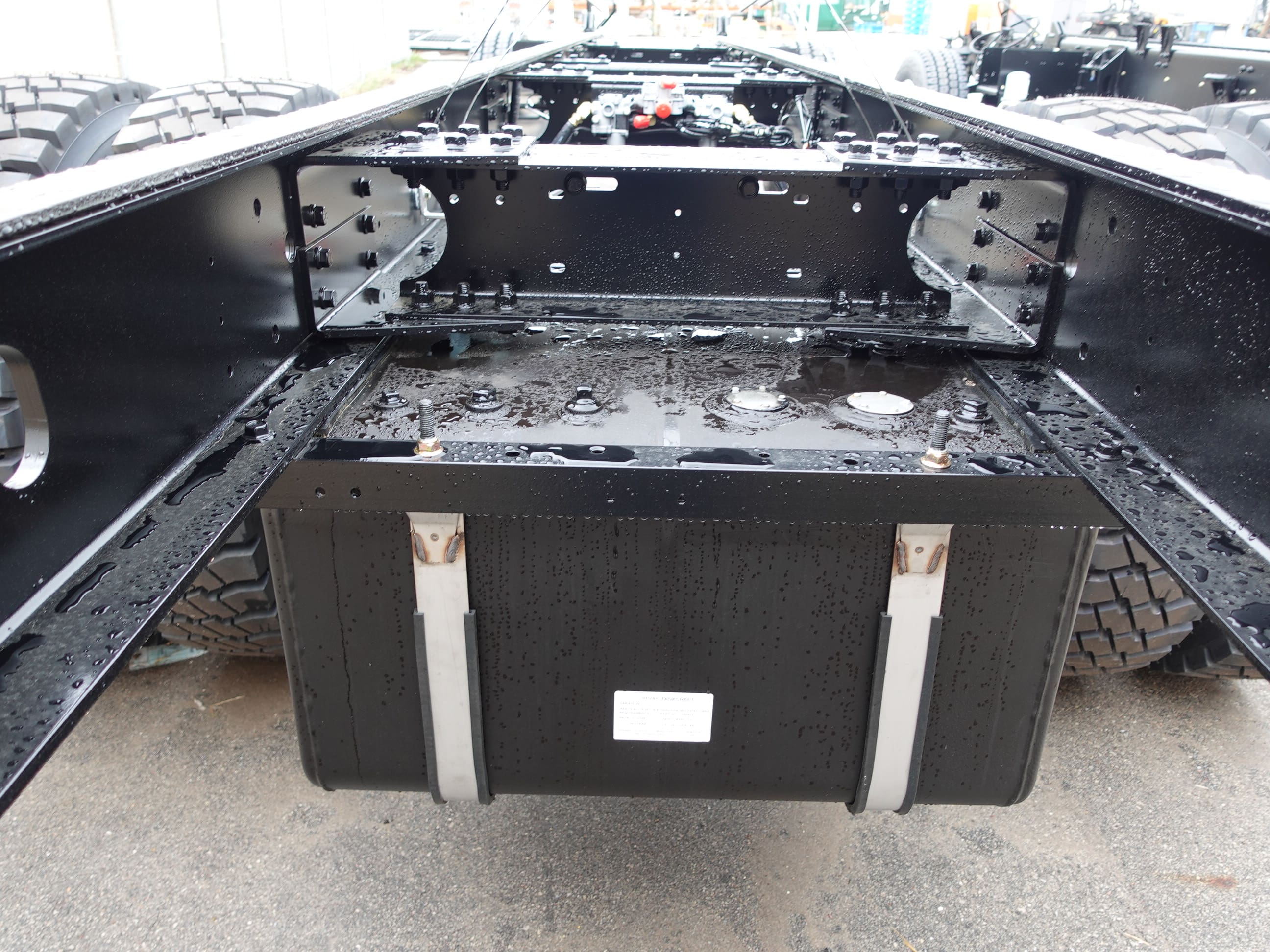

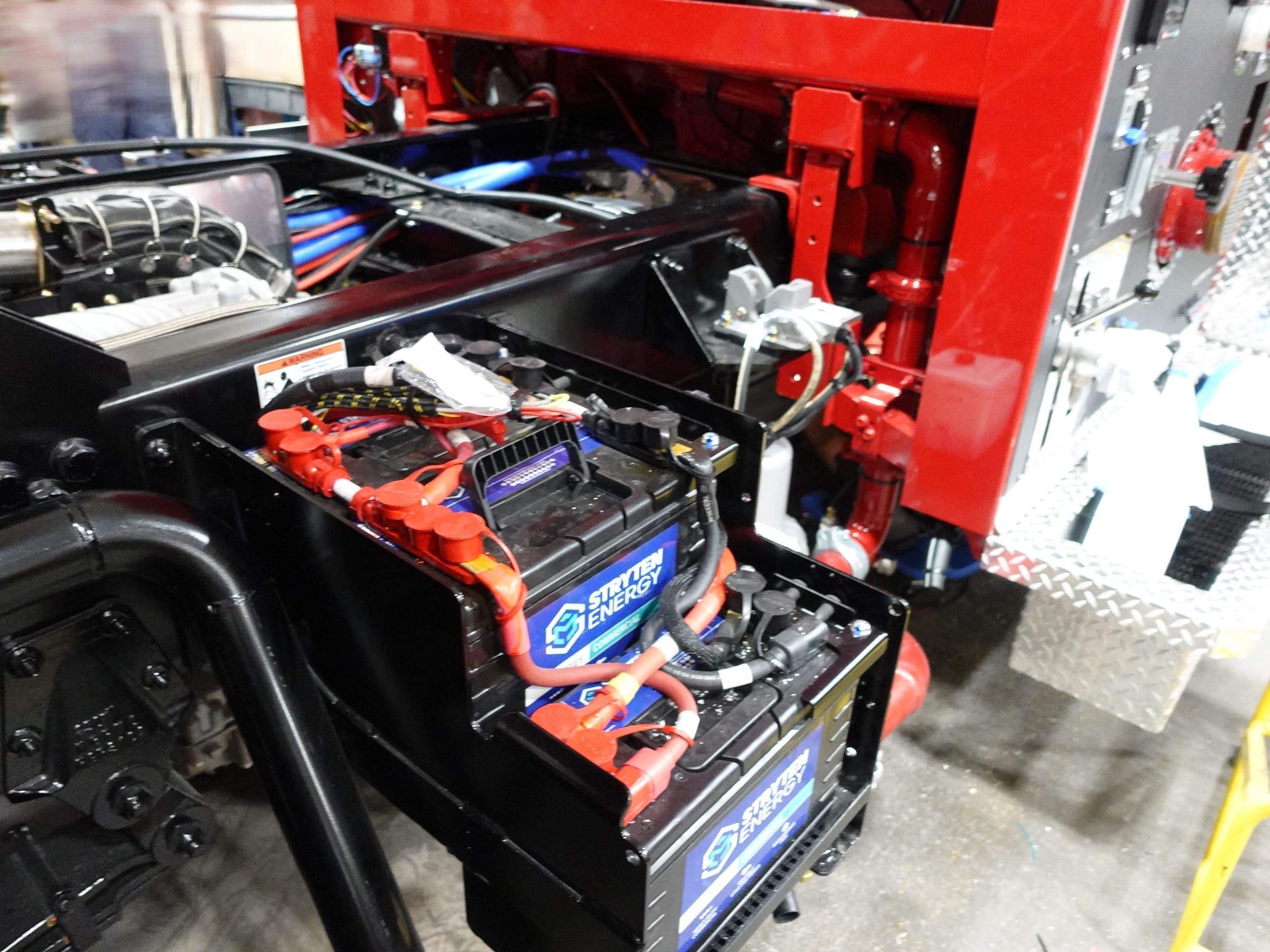

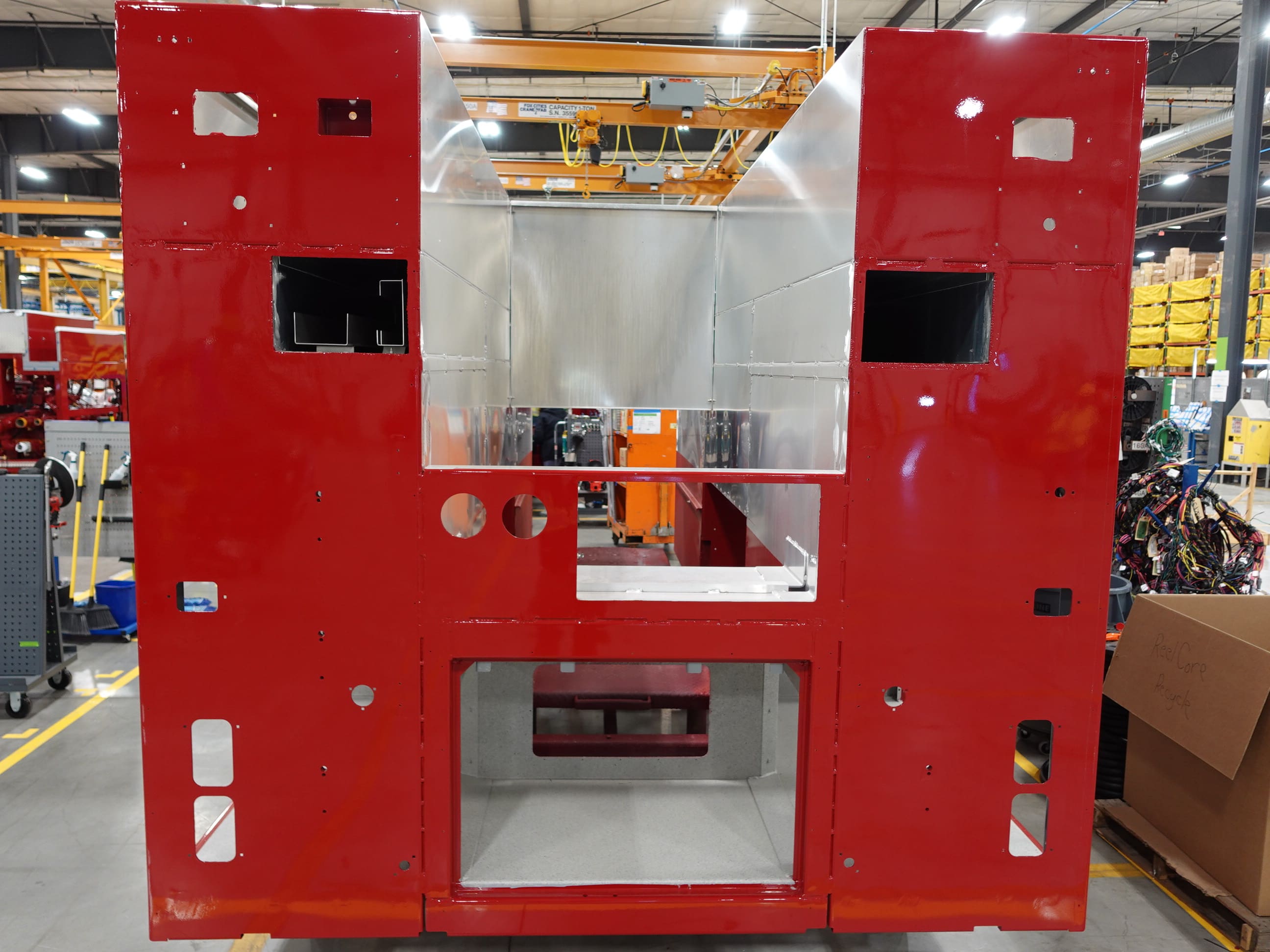

the chassis at the start of initial apparatus assembly.

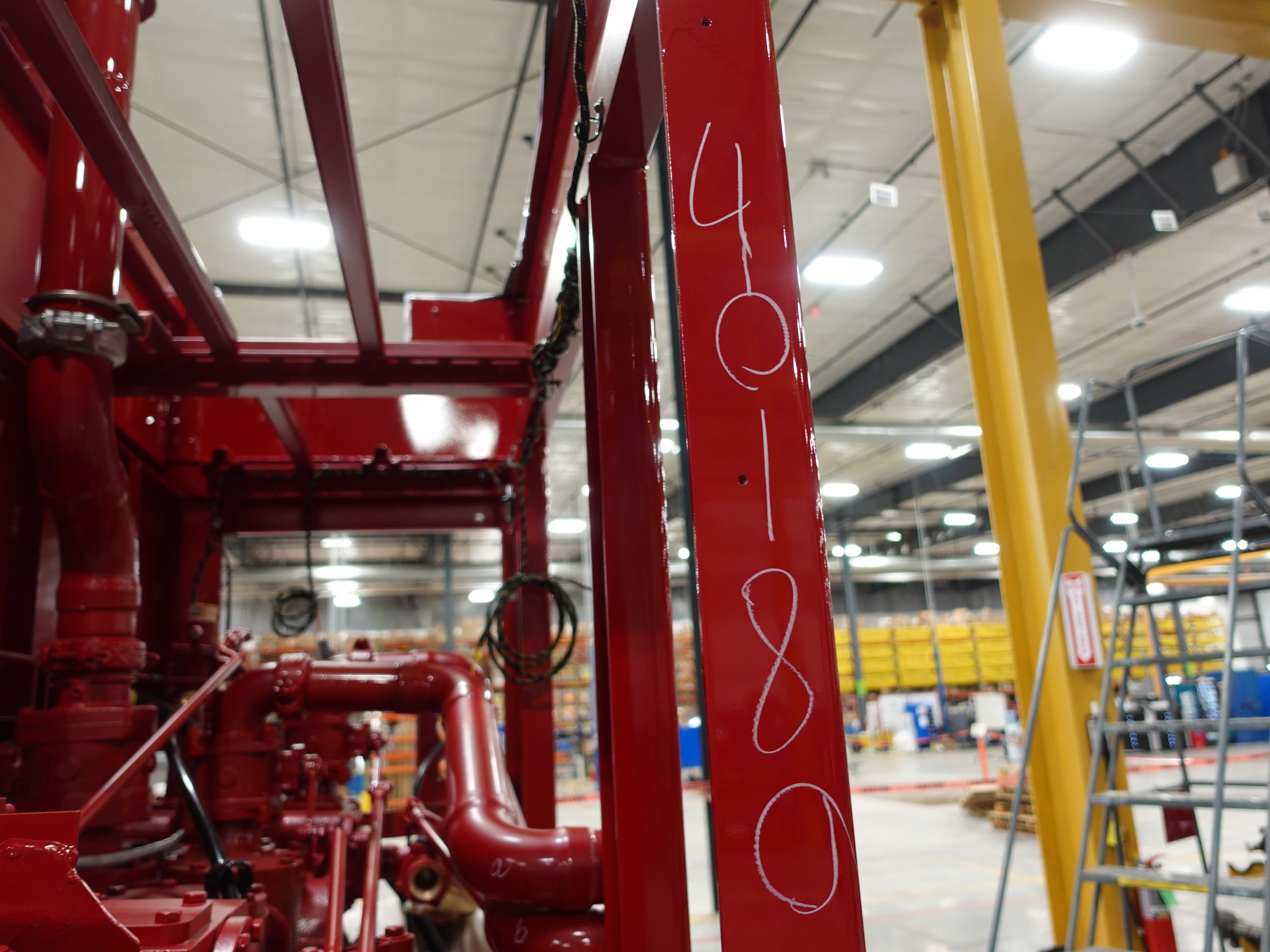

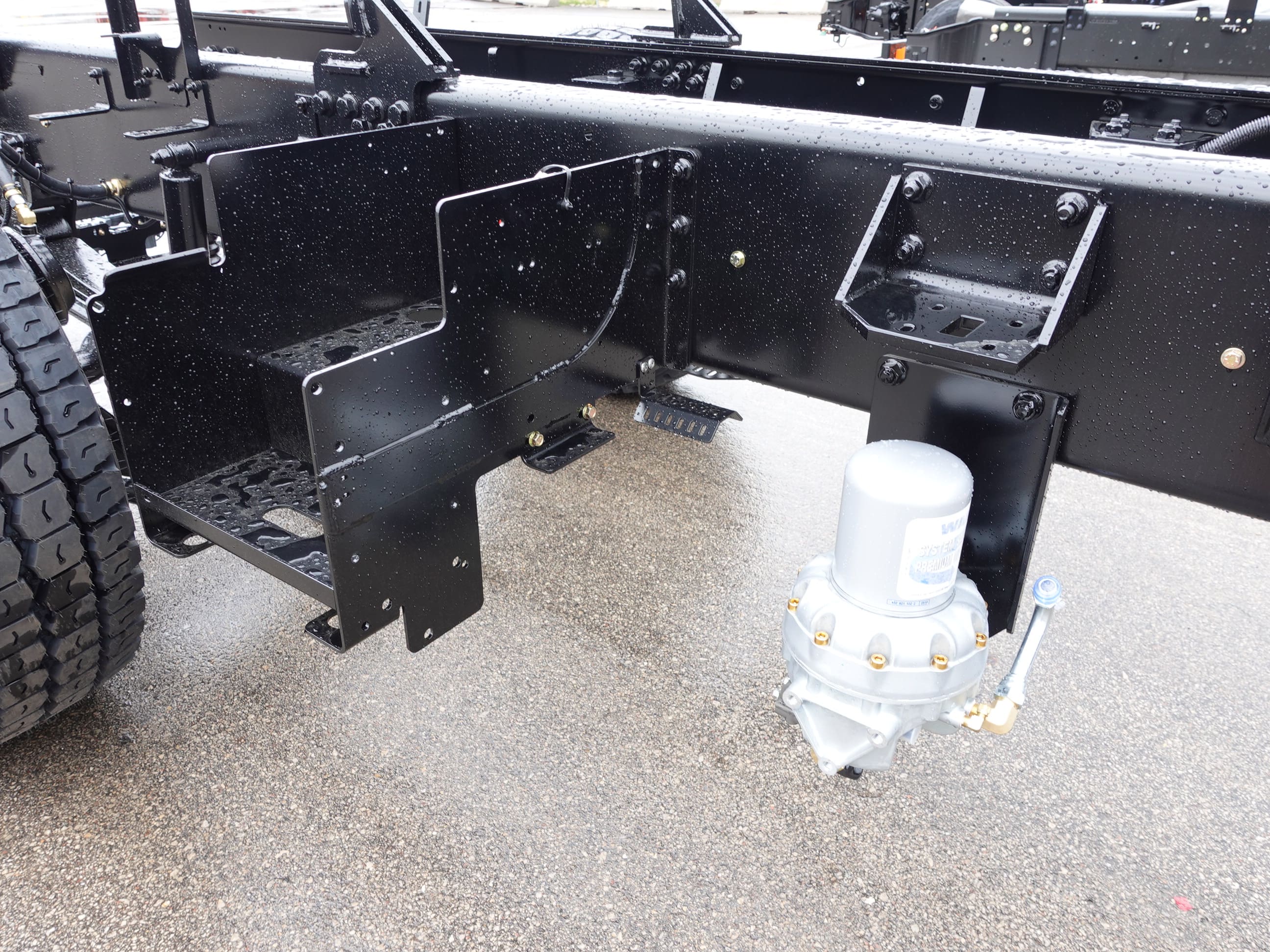

06-05-26

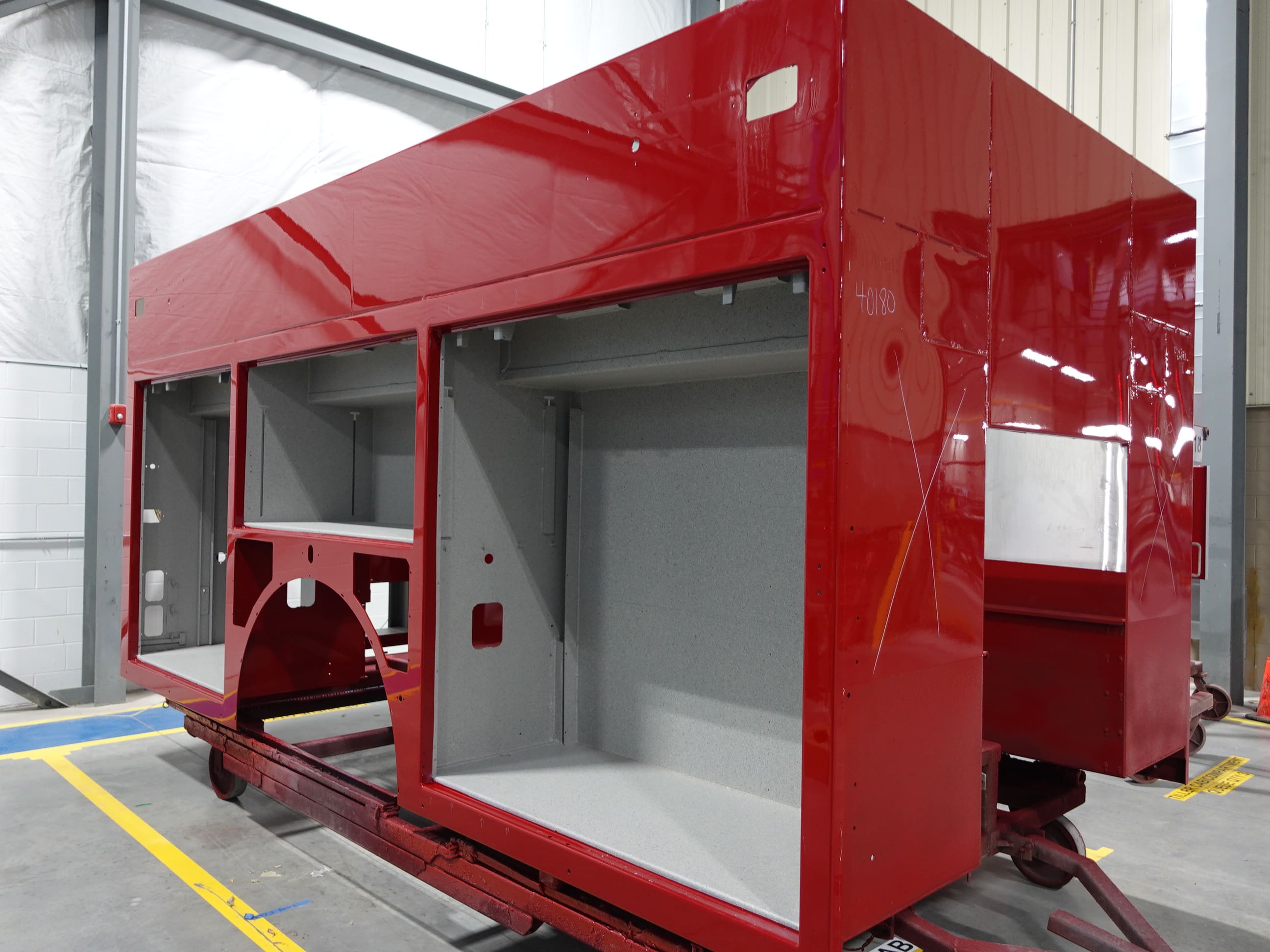

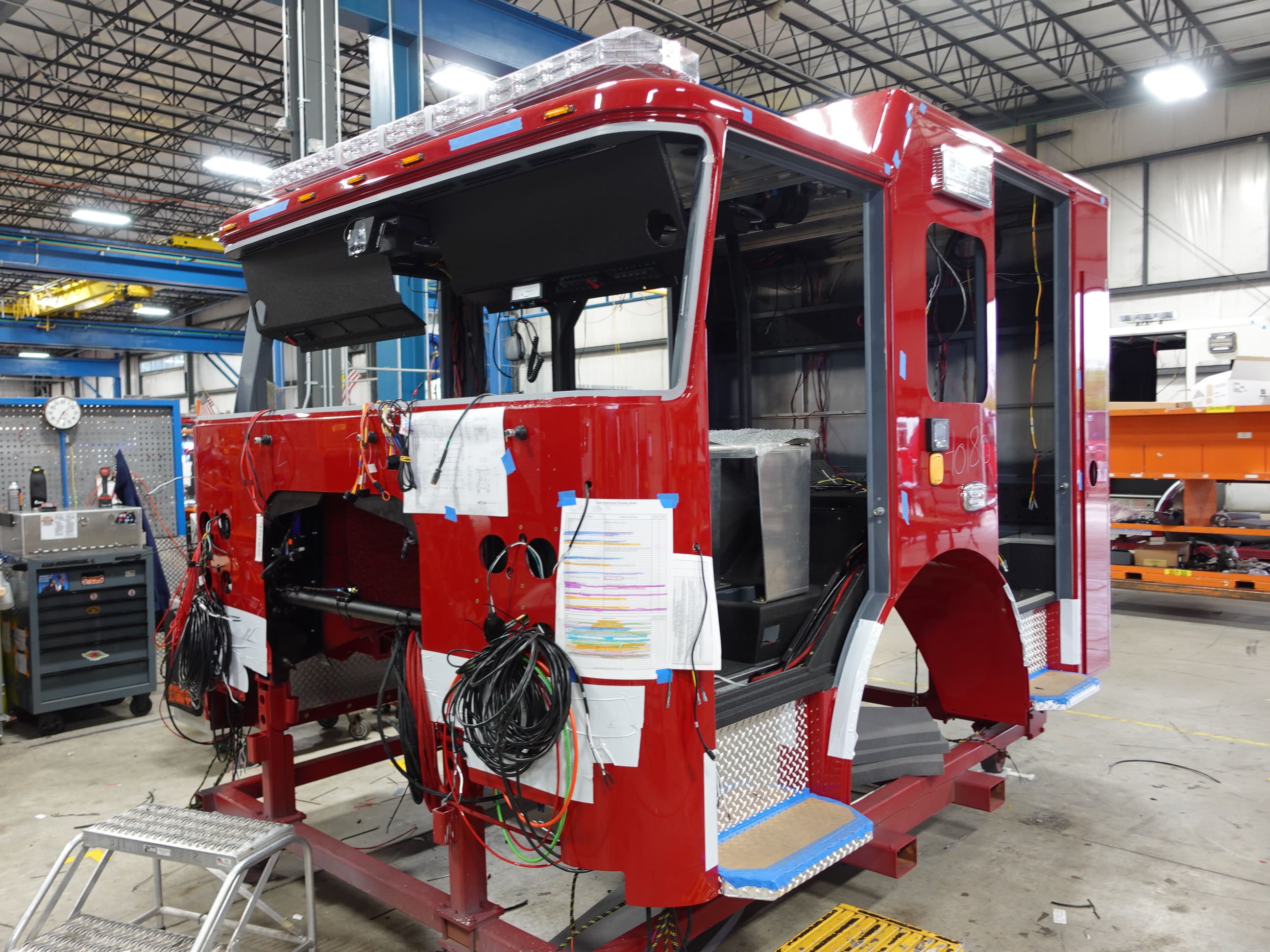

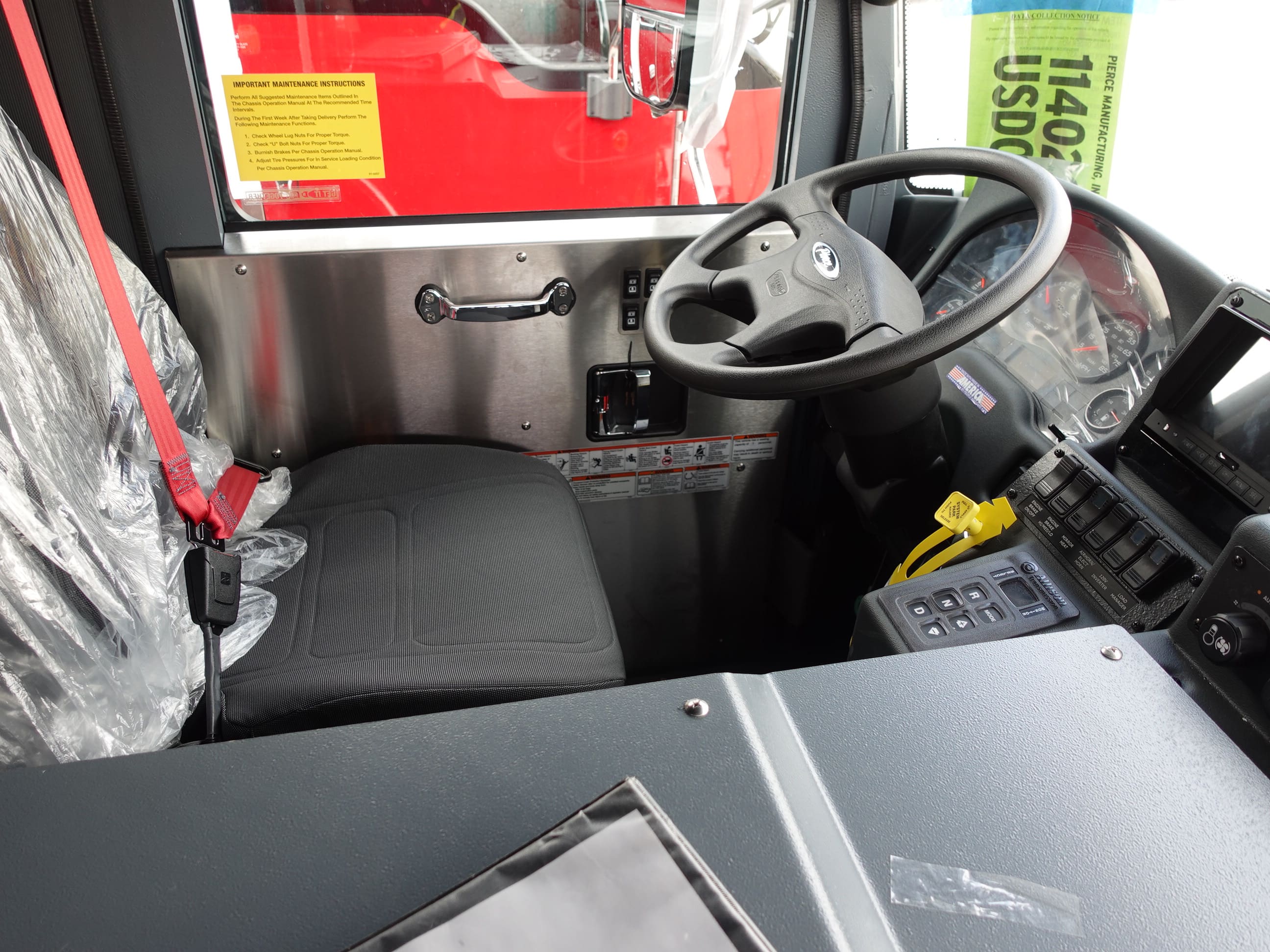

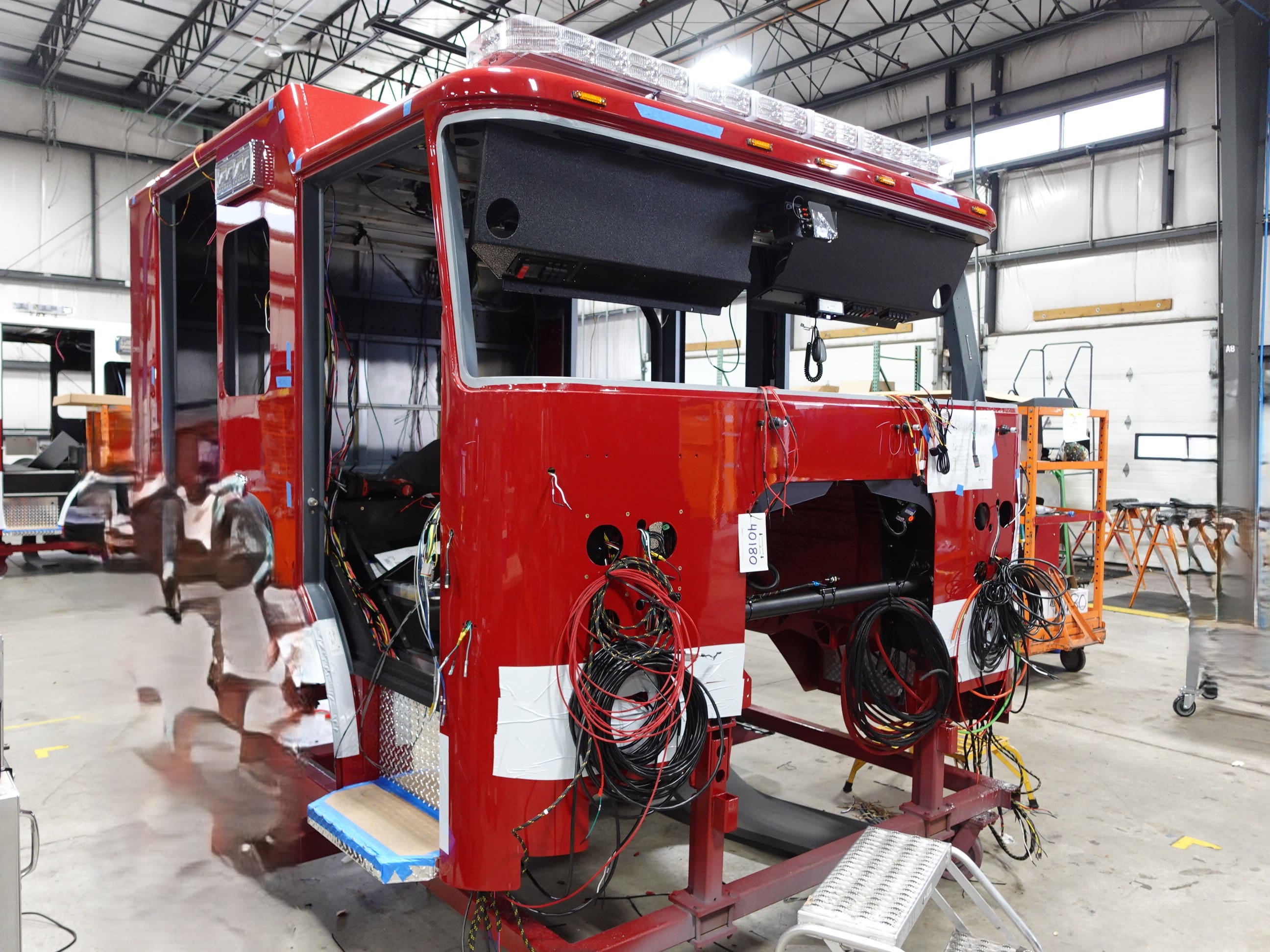

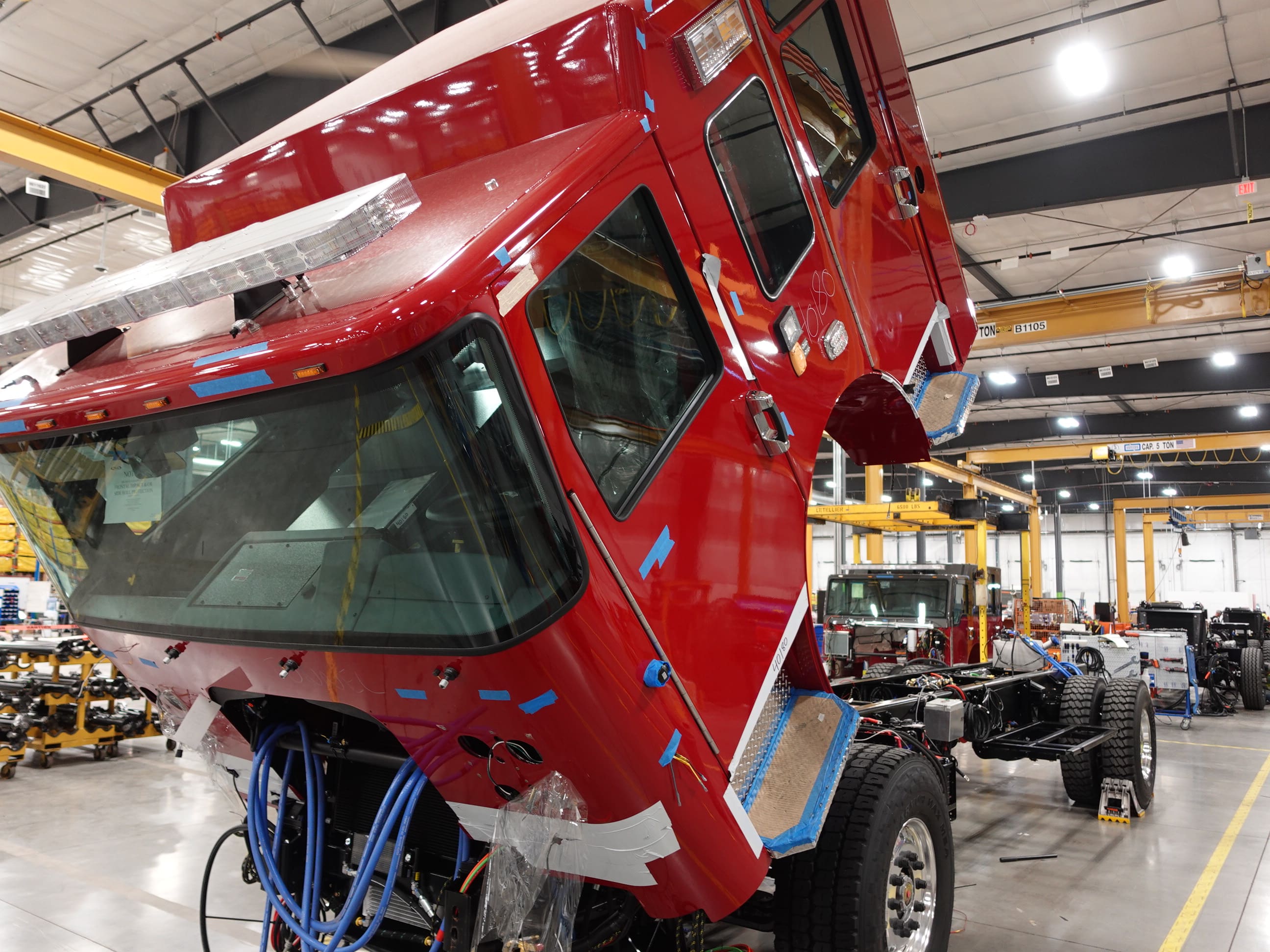

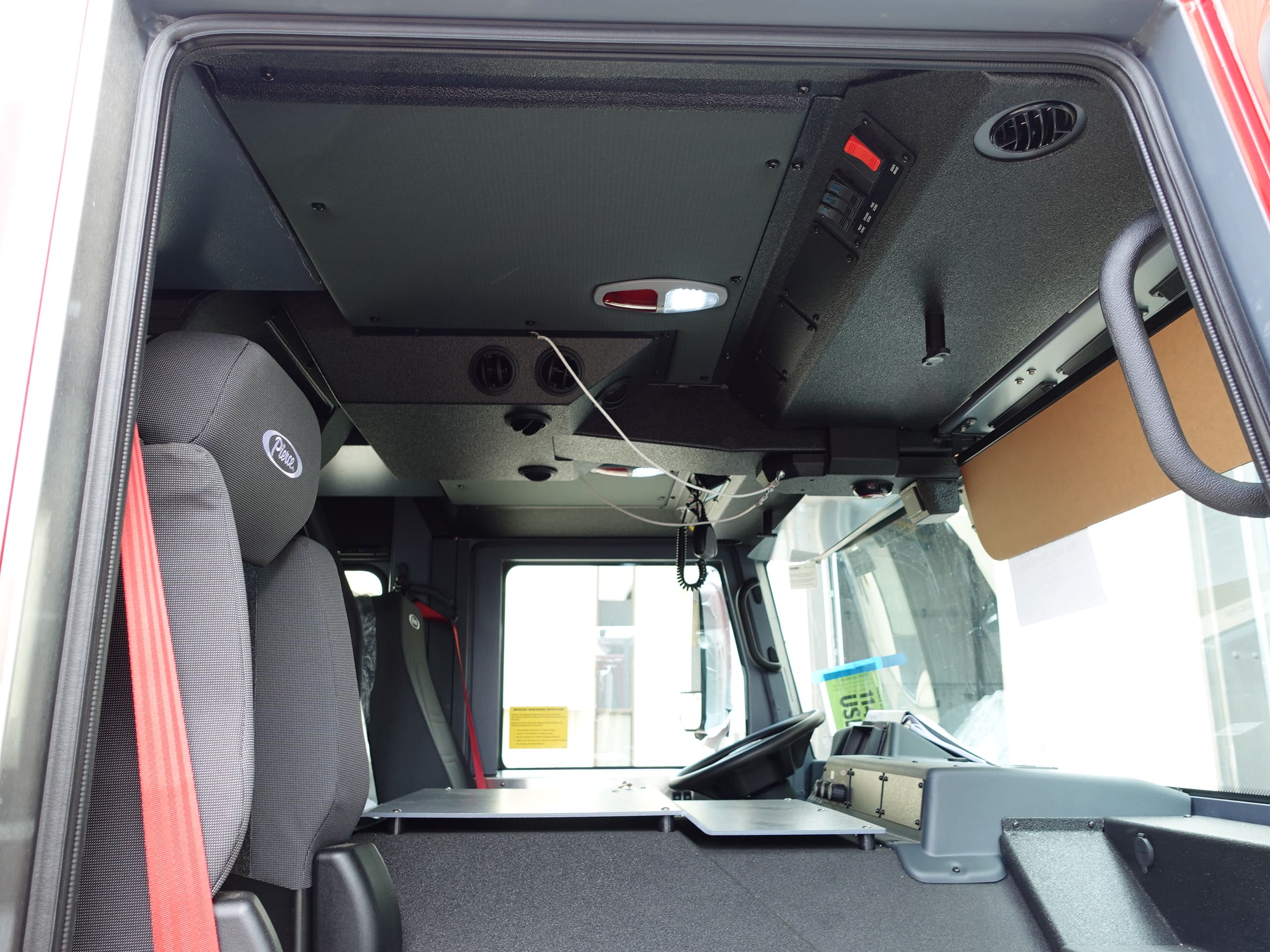

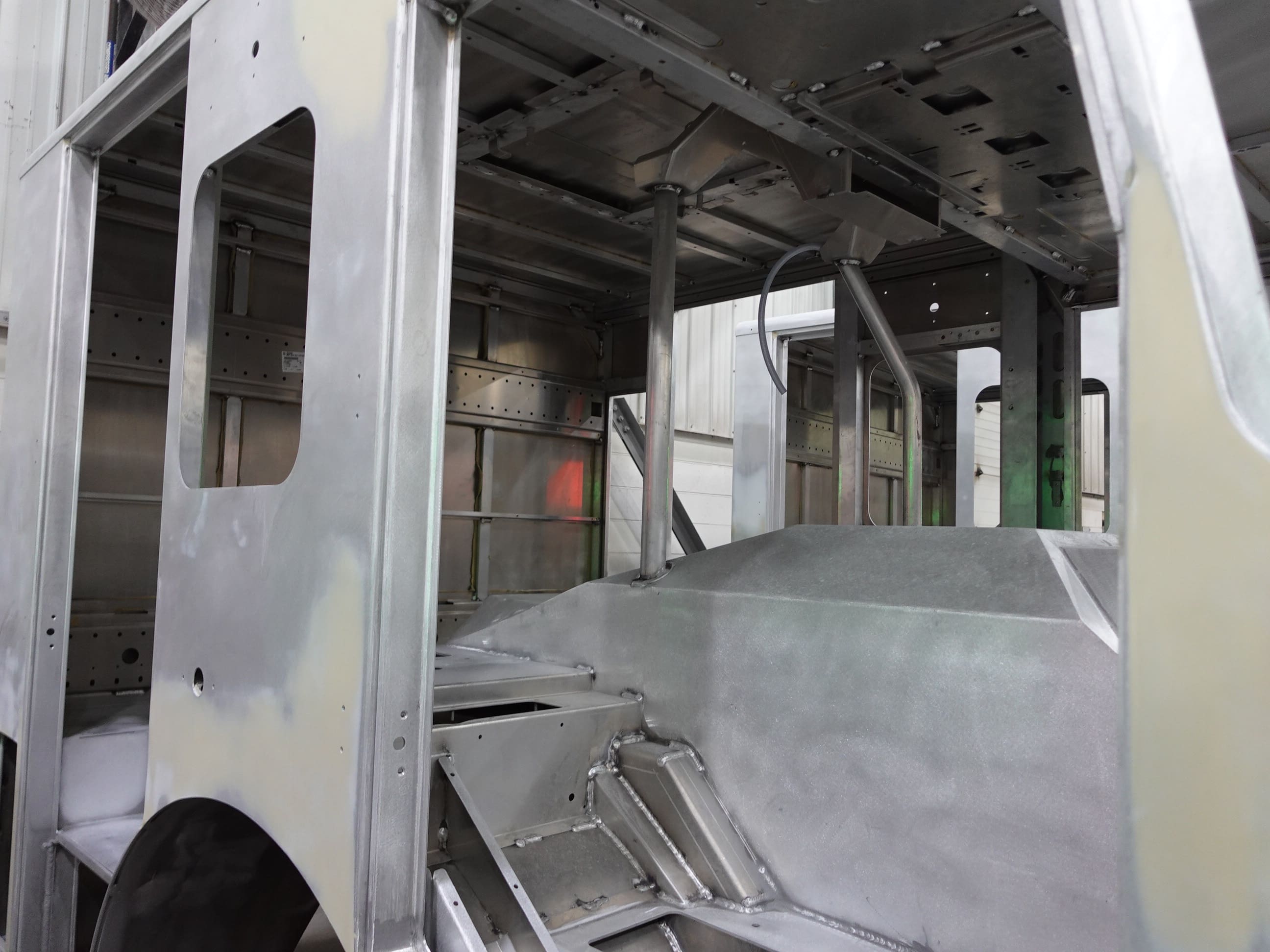

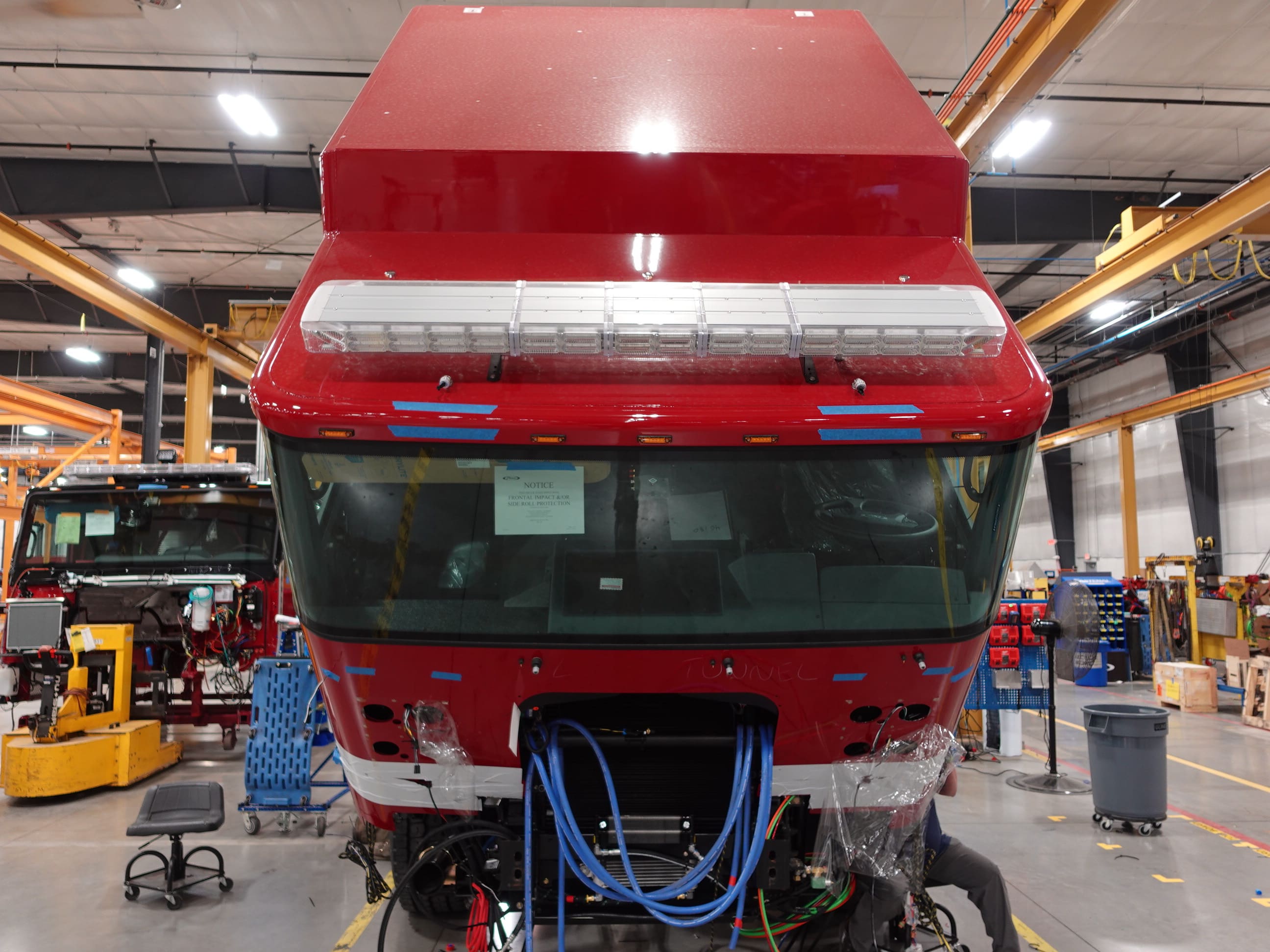

In this report, the cab completed initial assembly and was
merged with the frame, the pump house was in queue to be

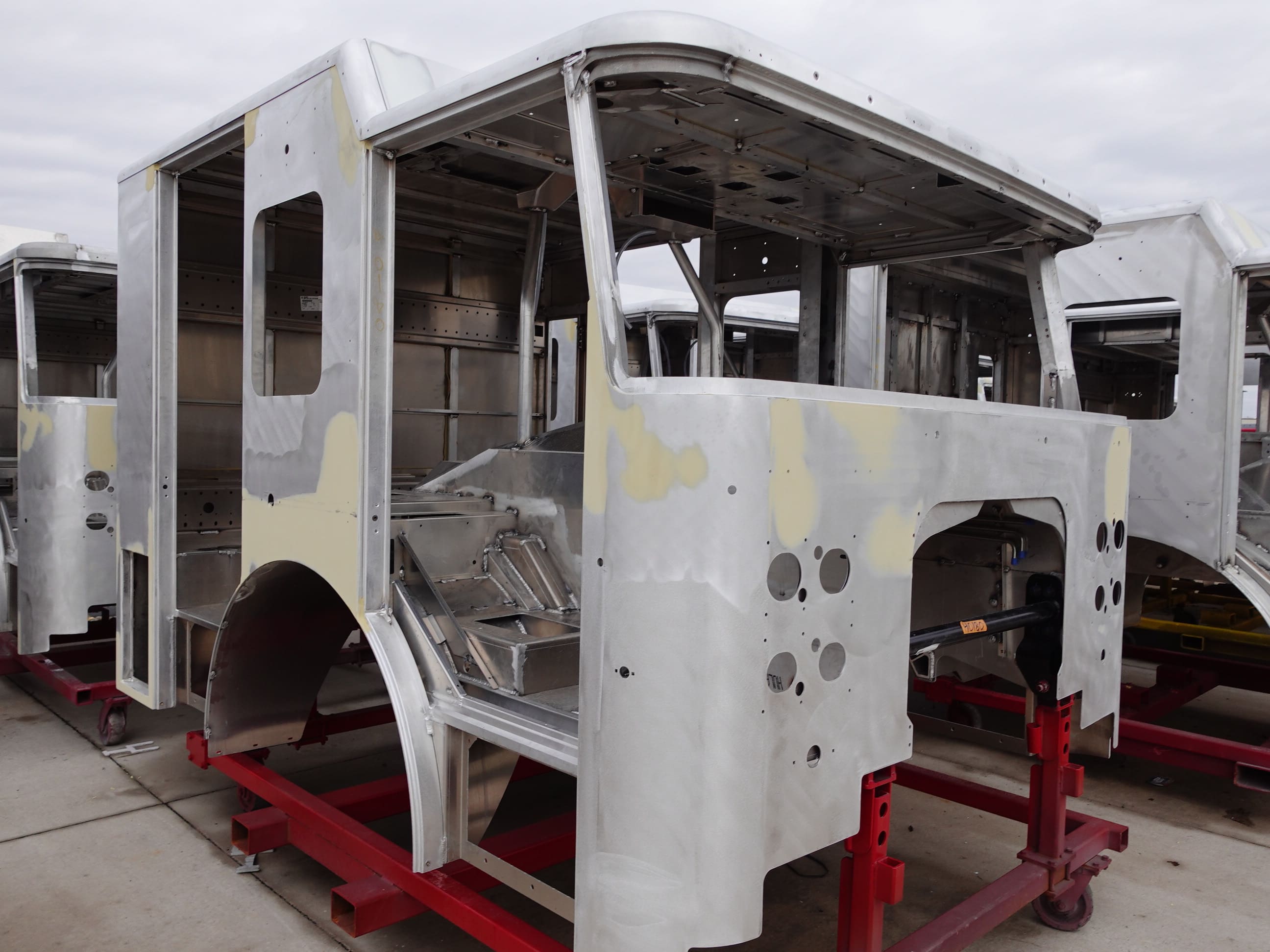

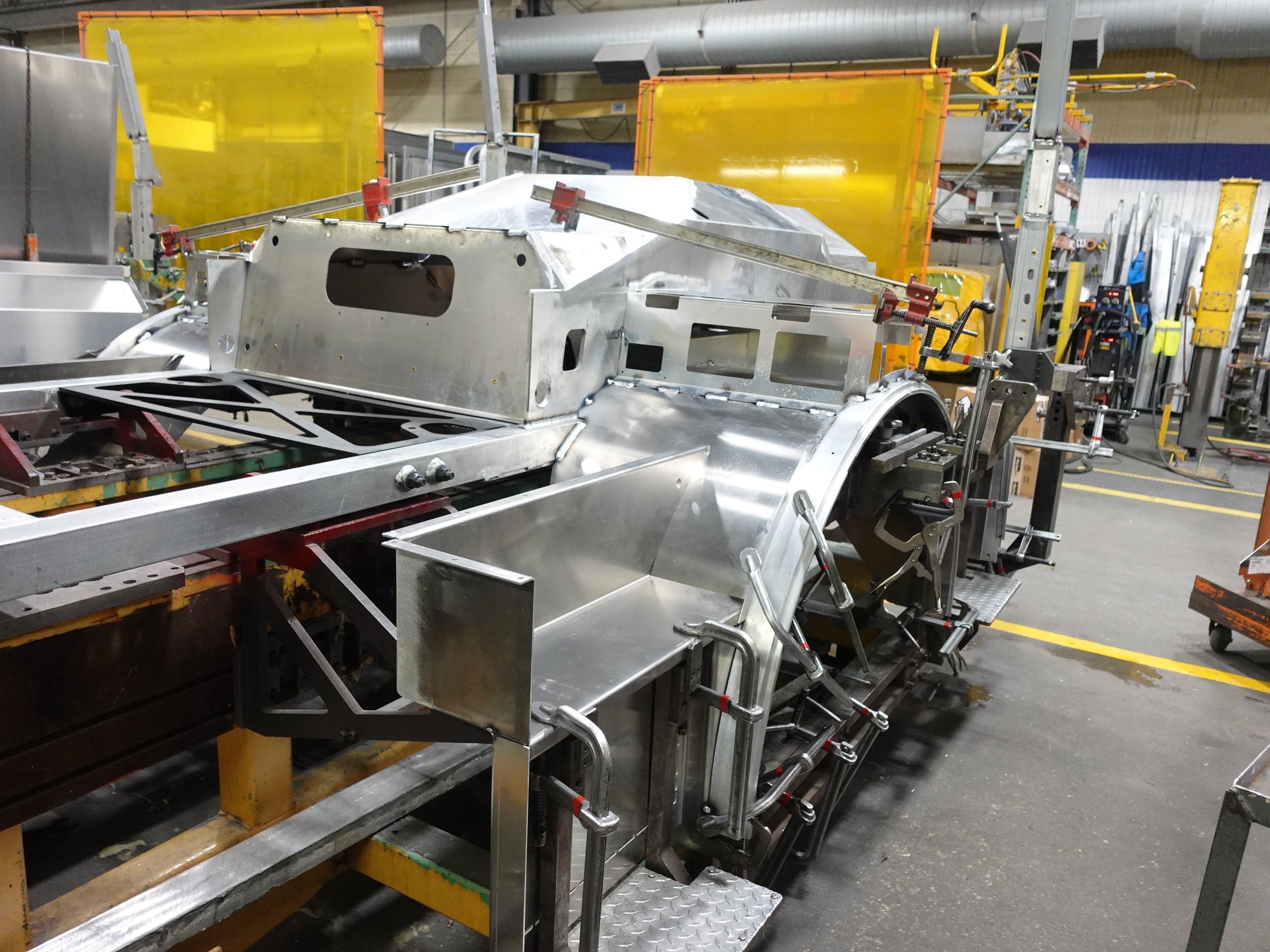

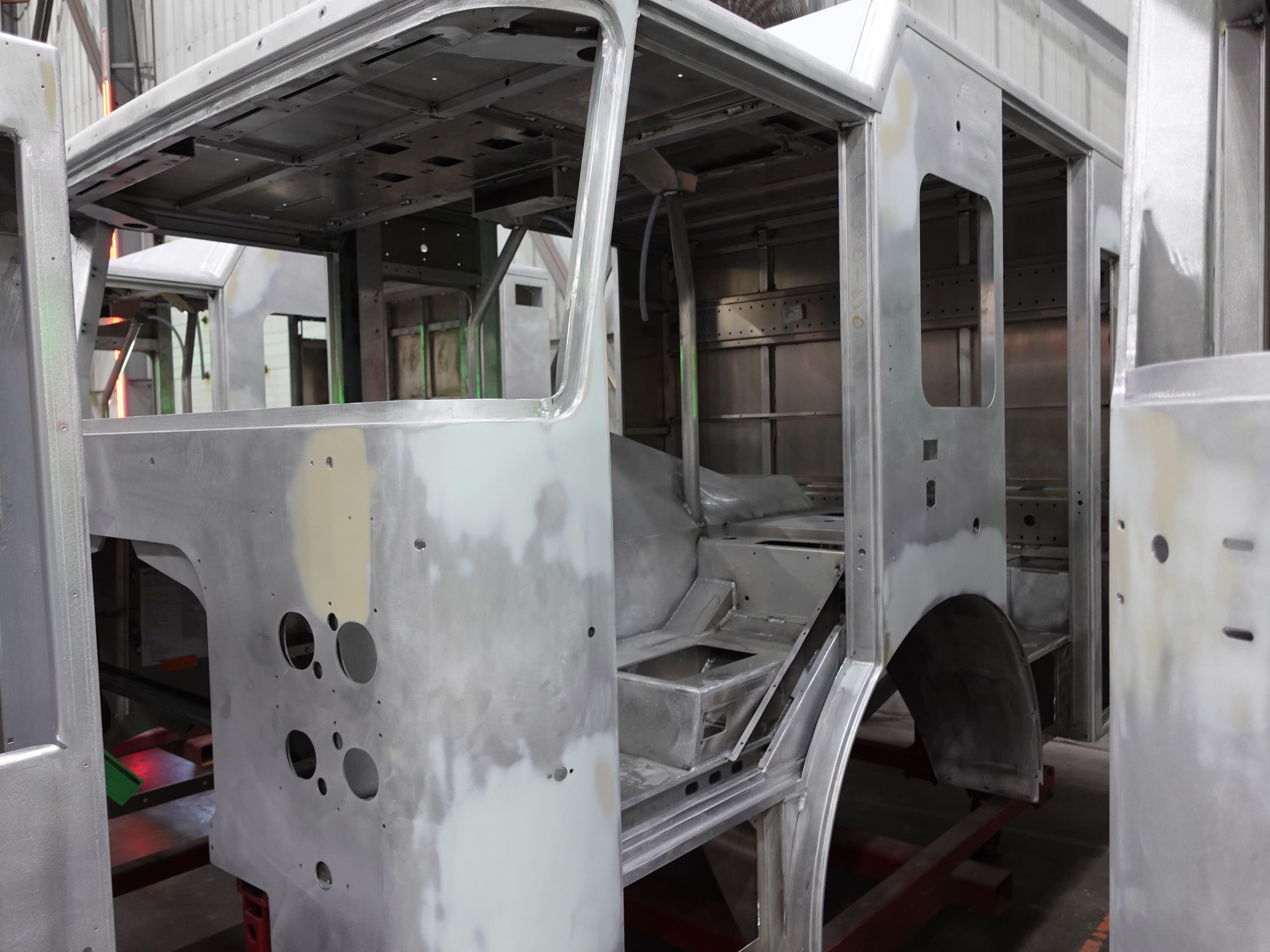

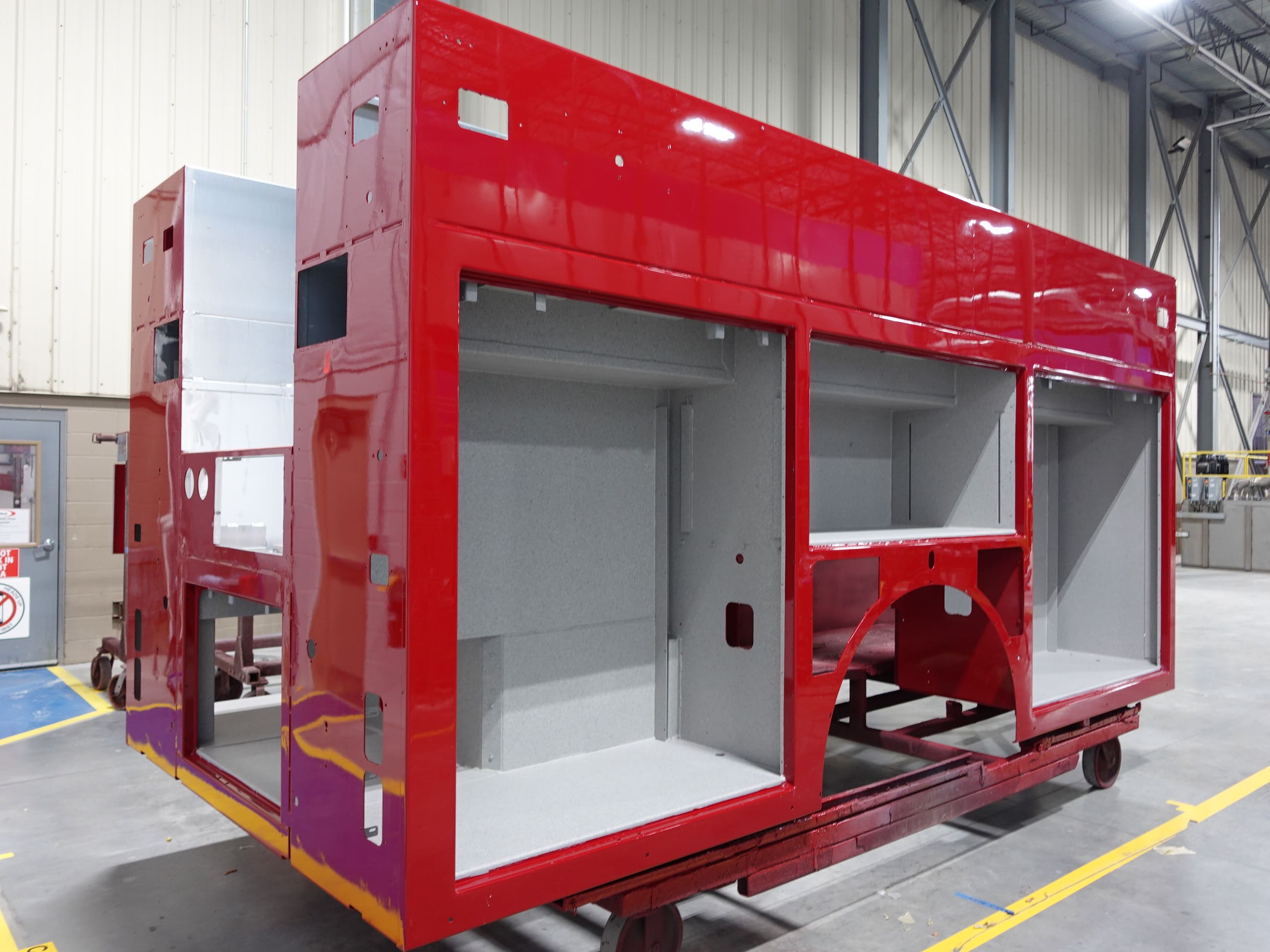

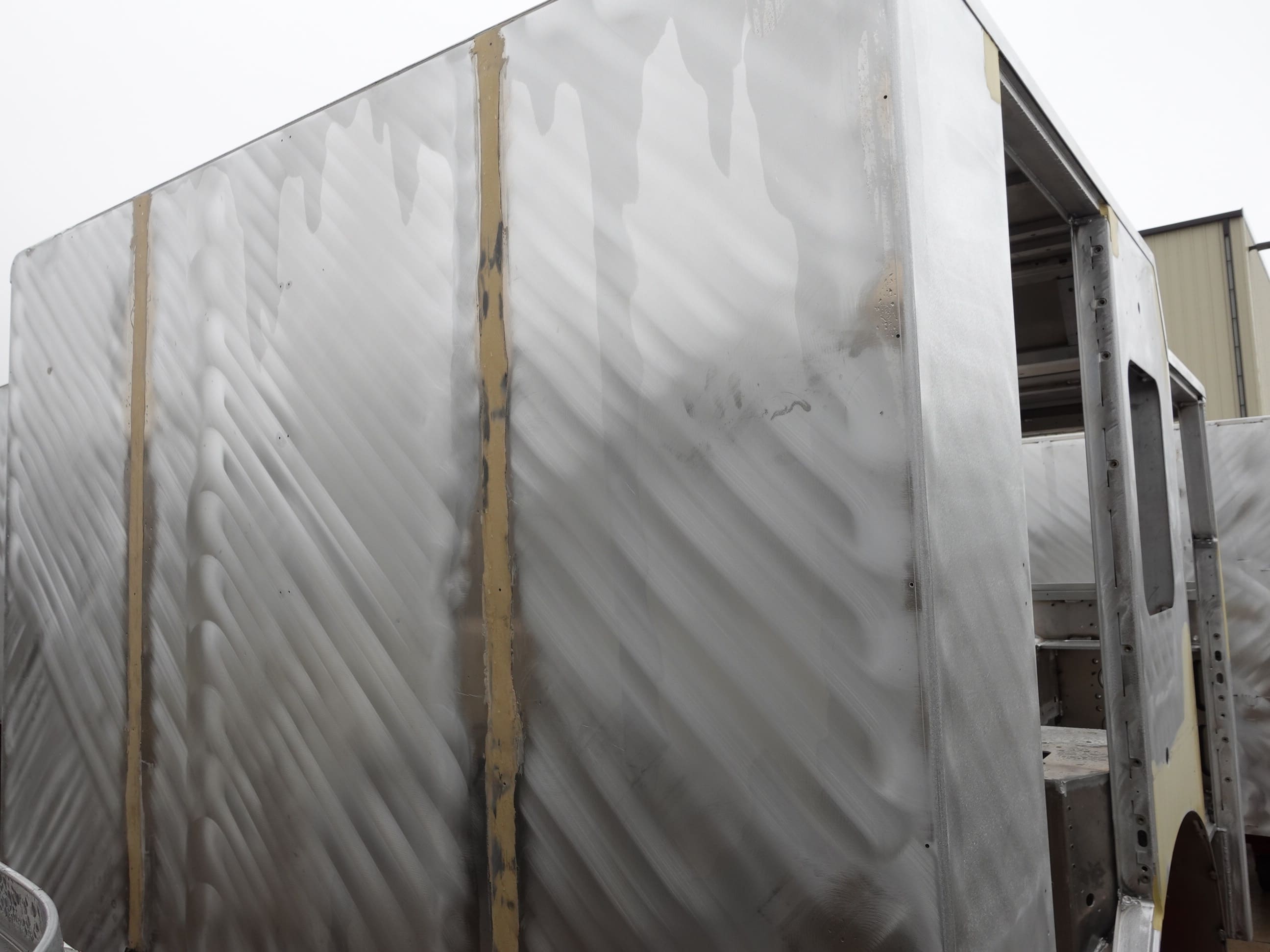

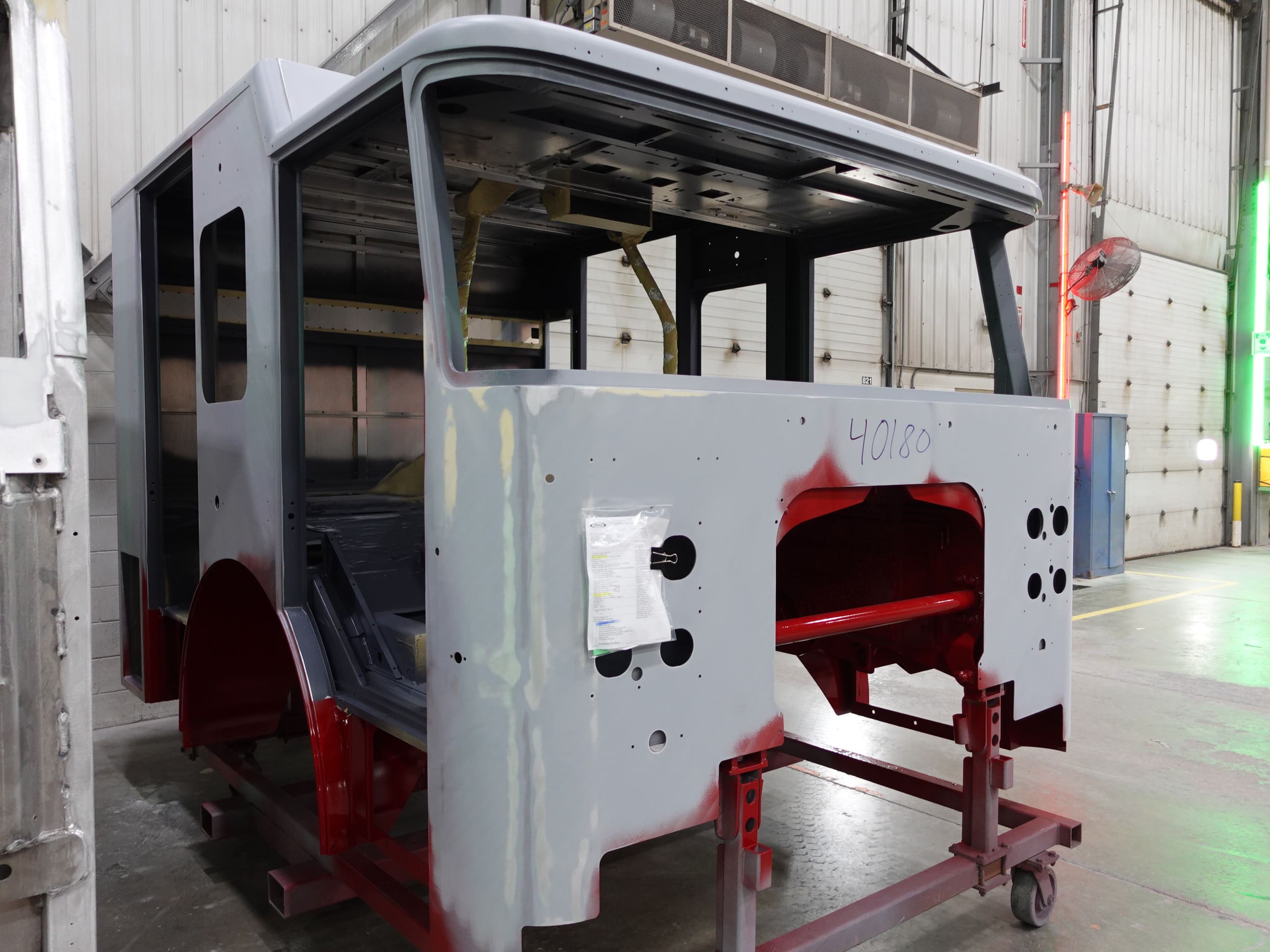

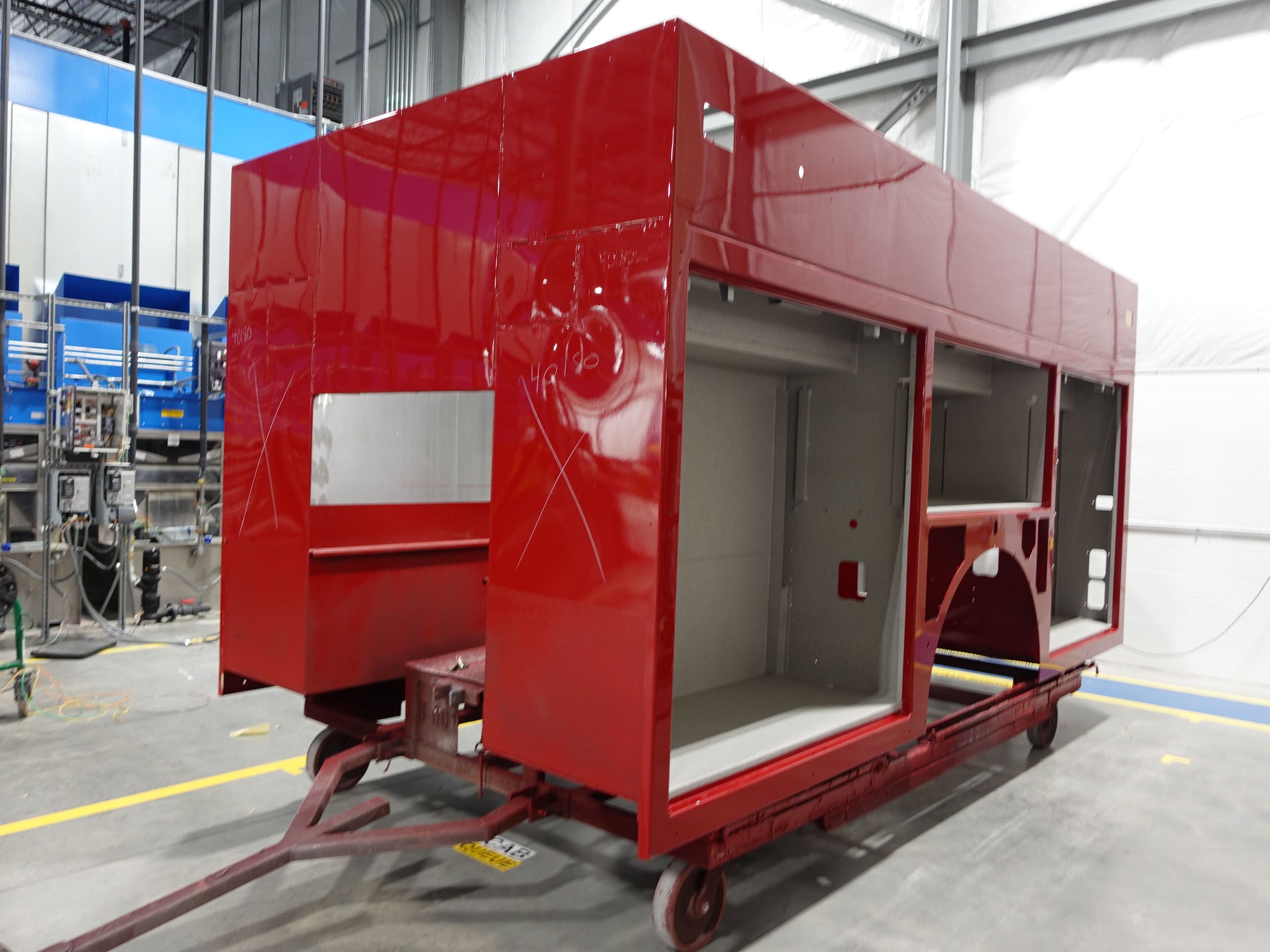

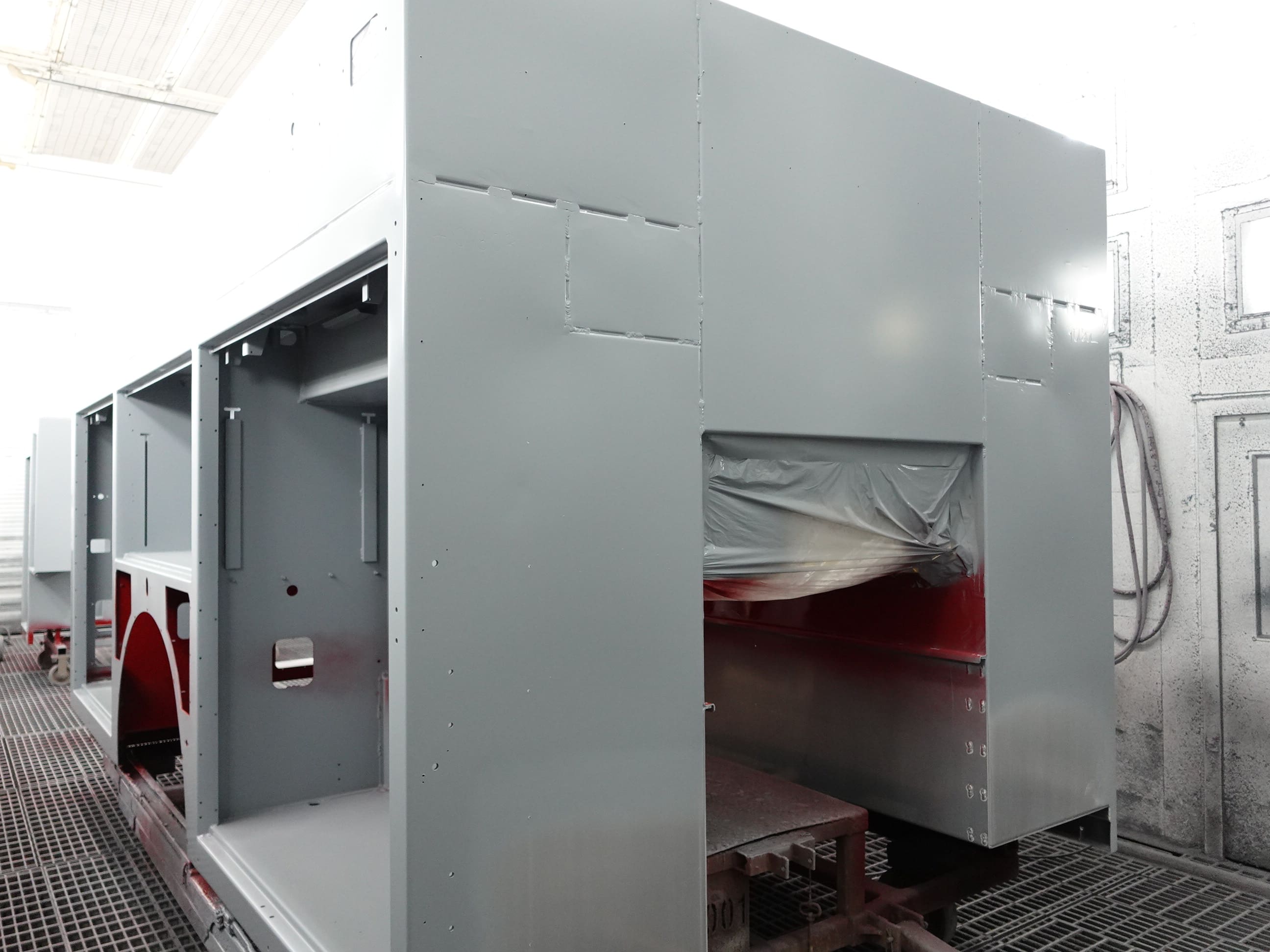

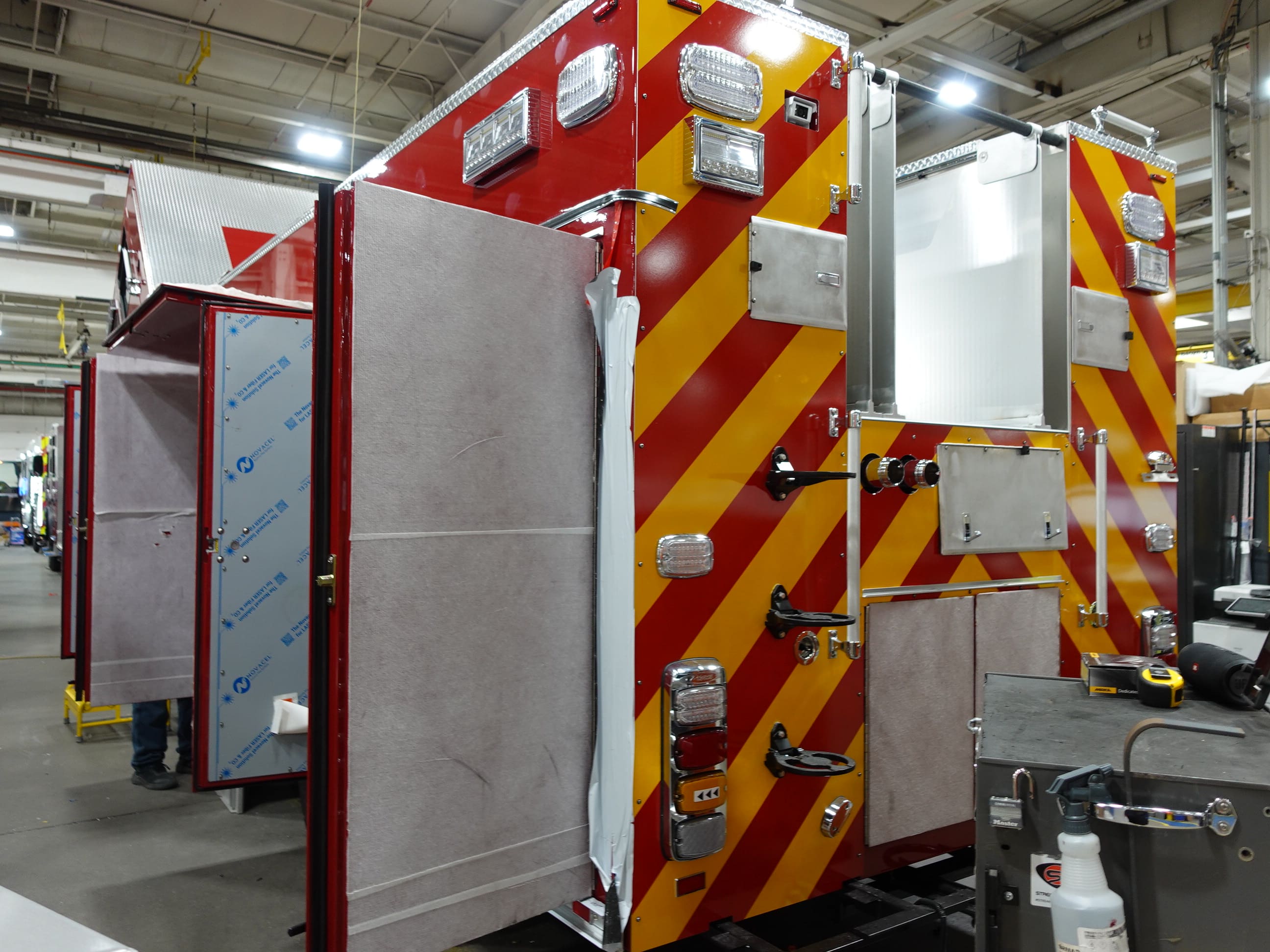

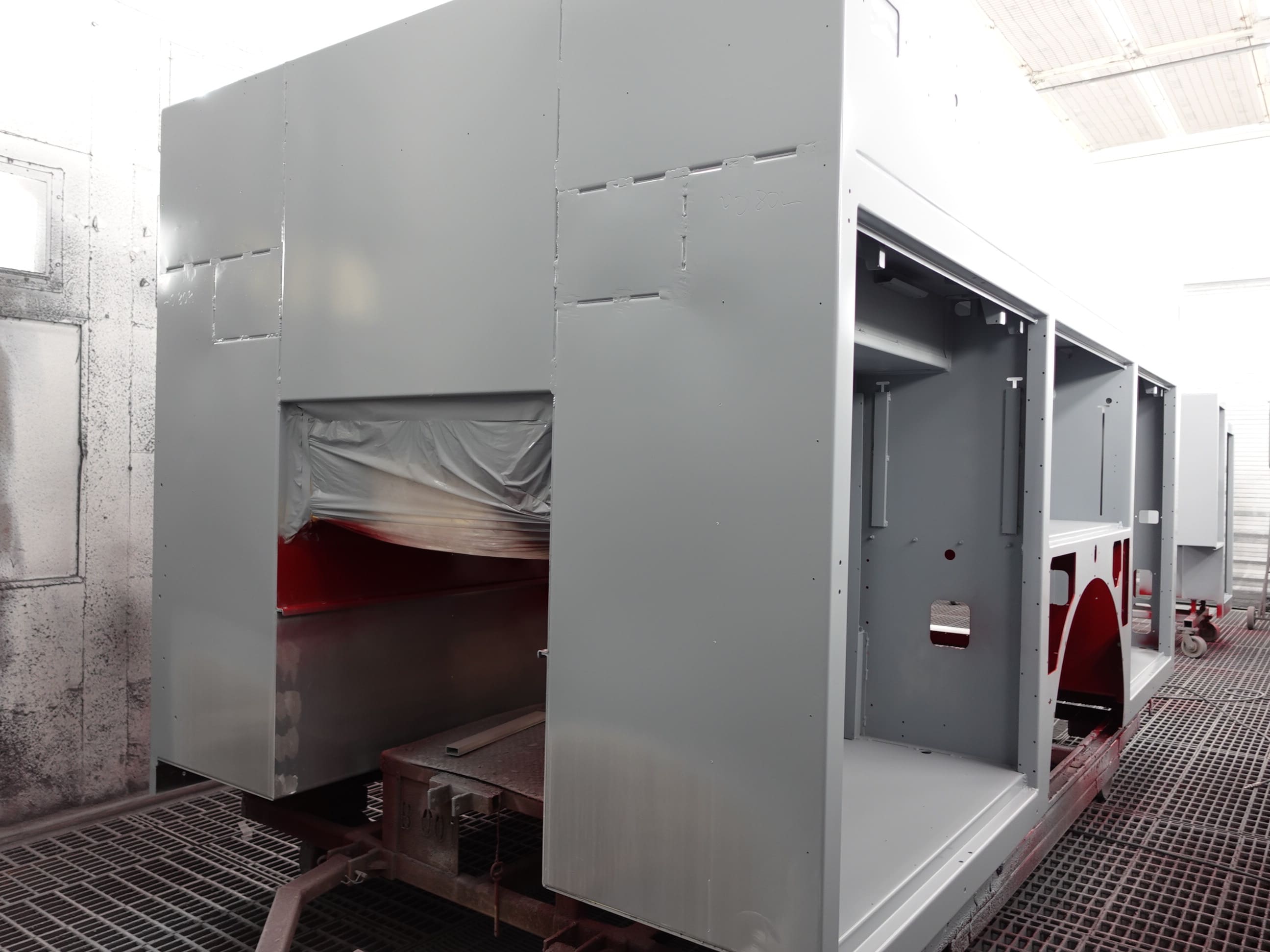

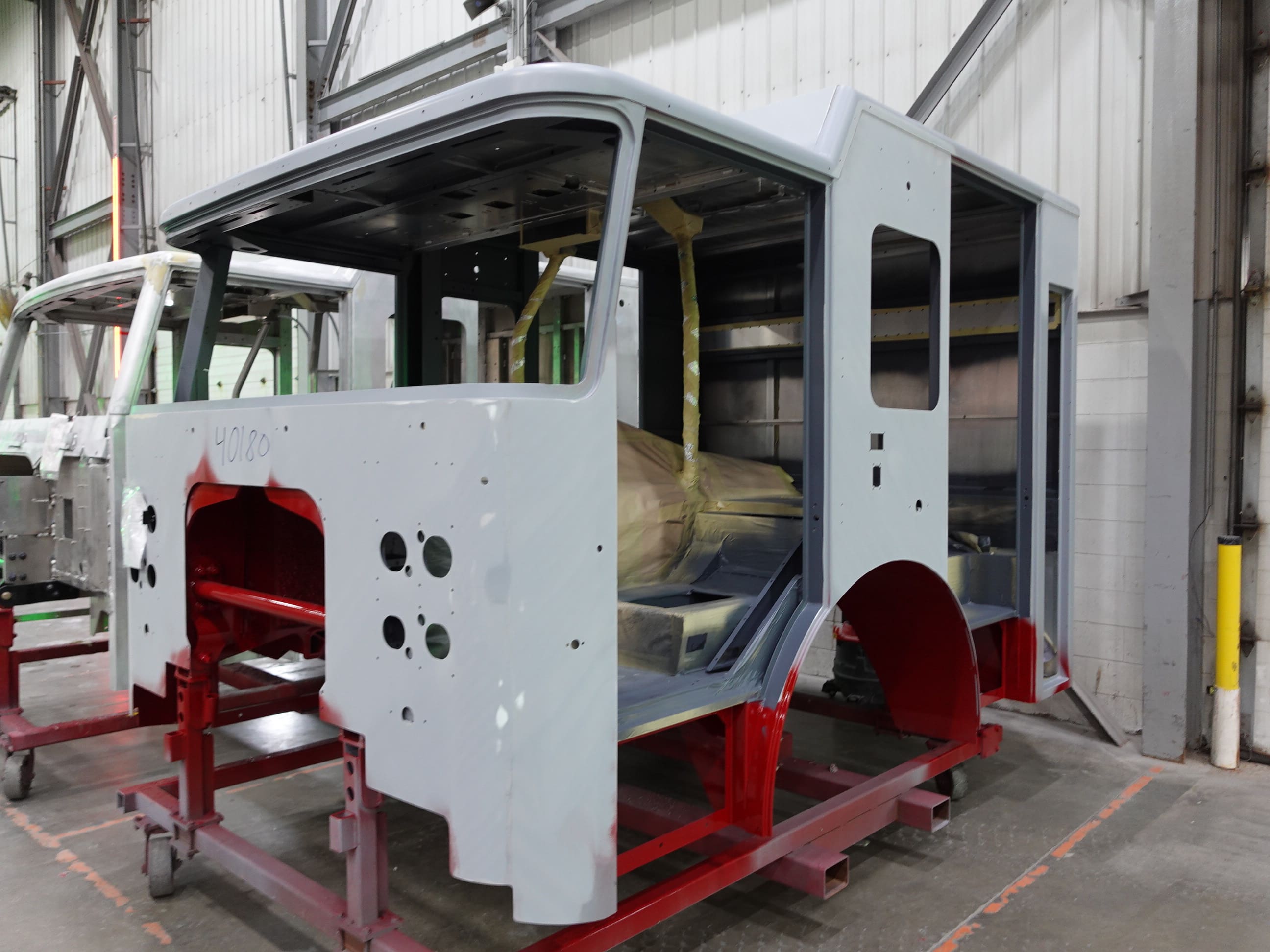

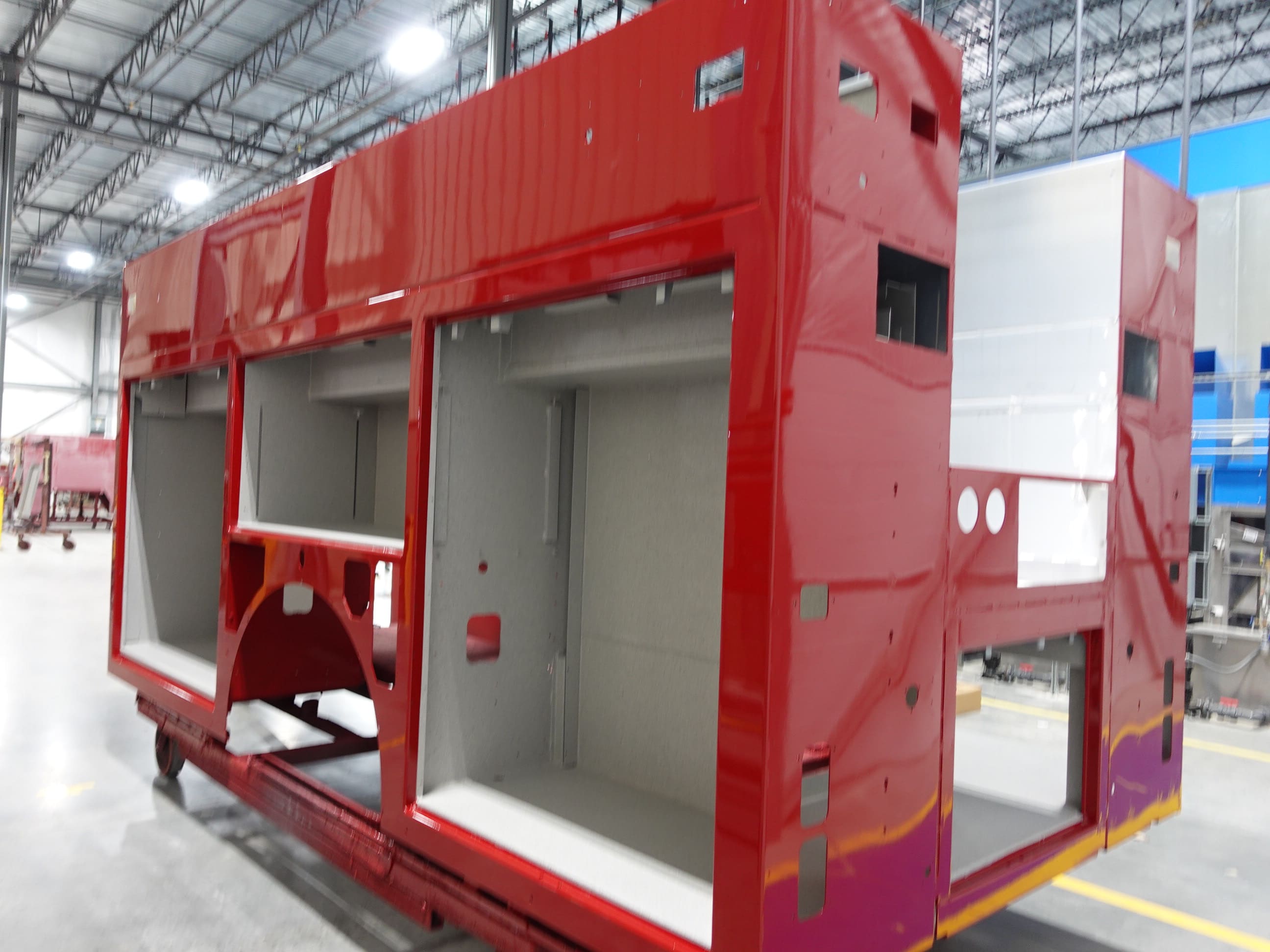

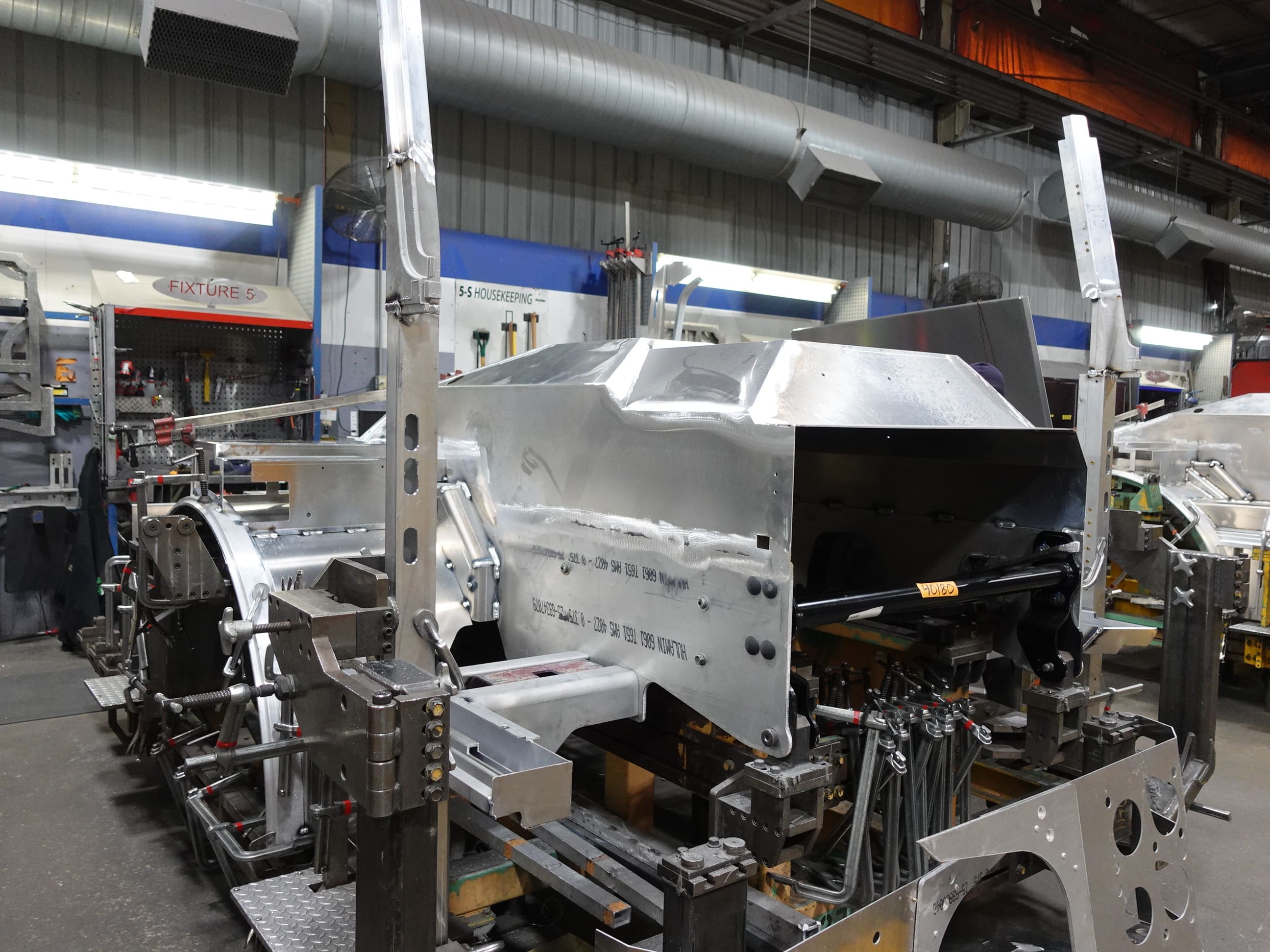

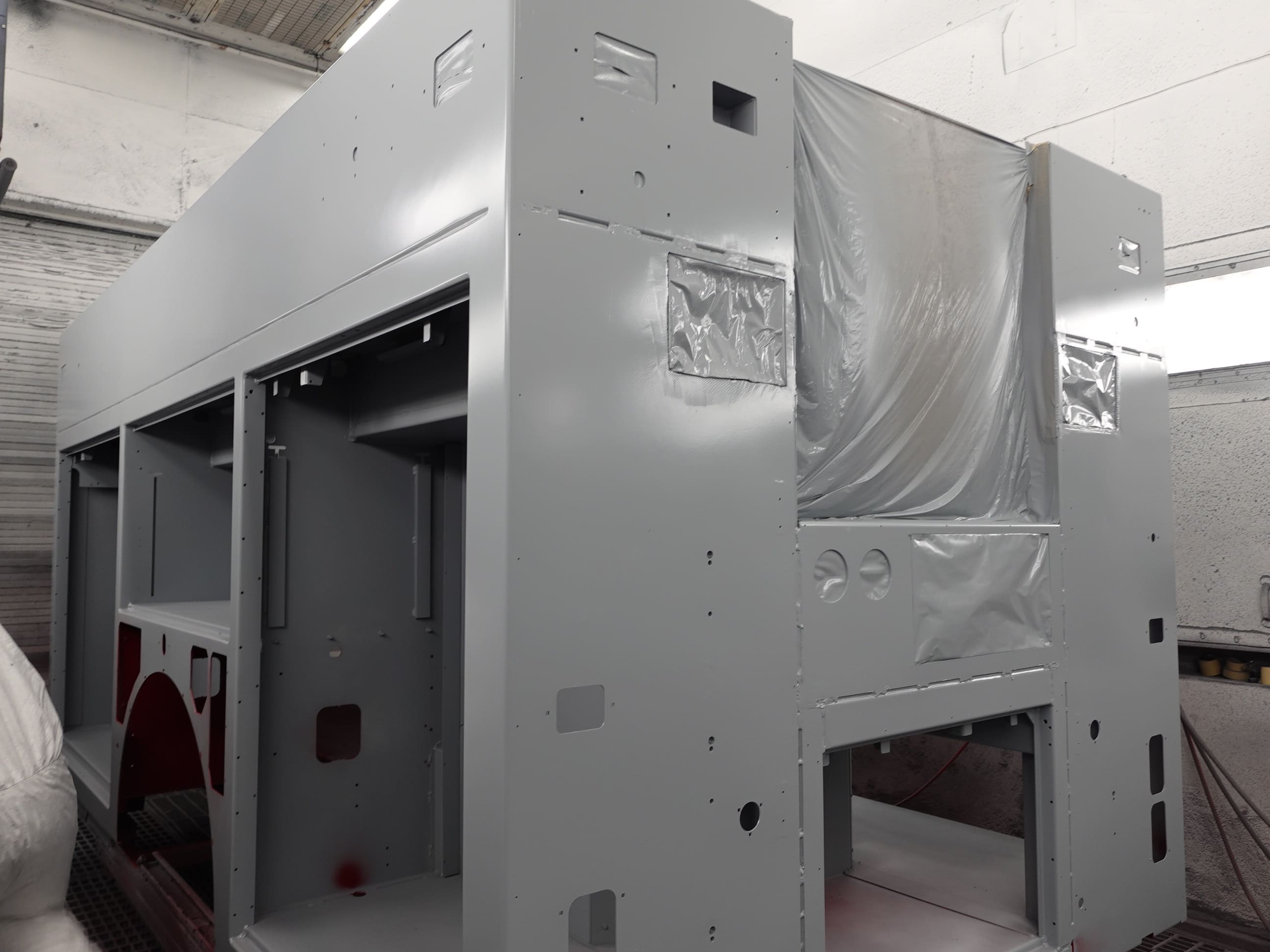

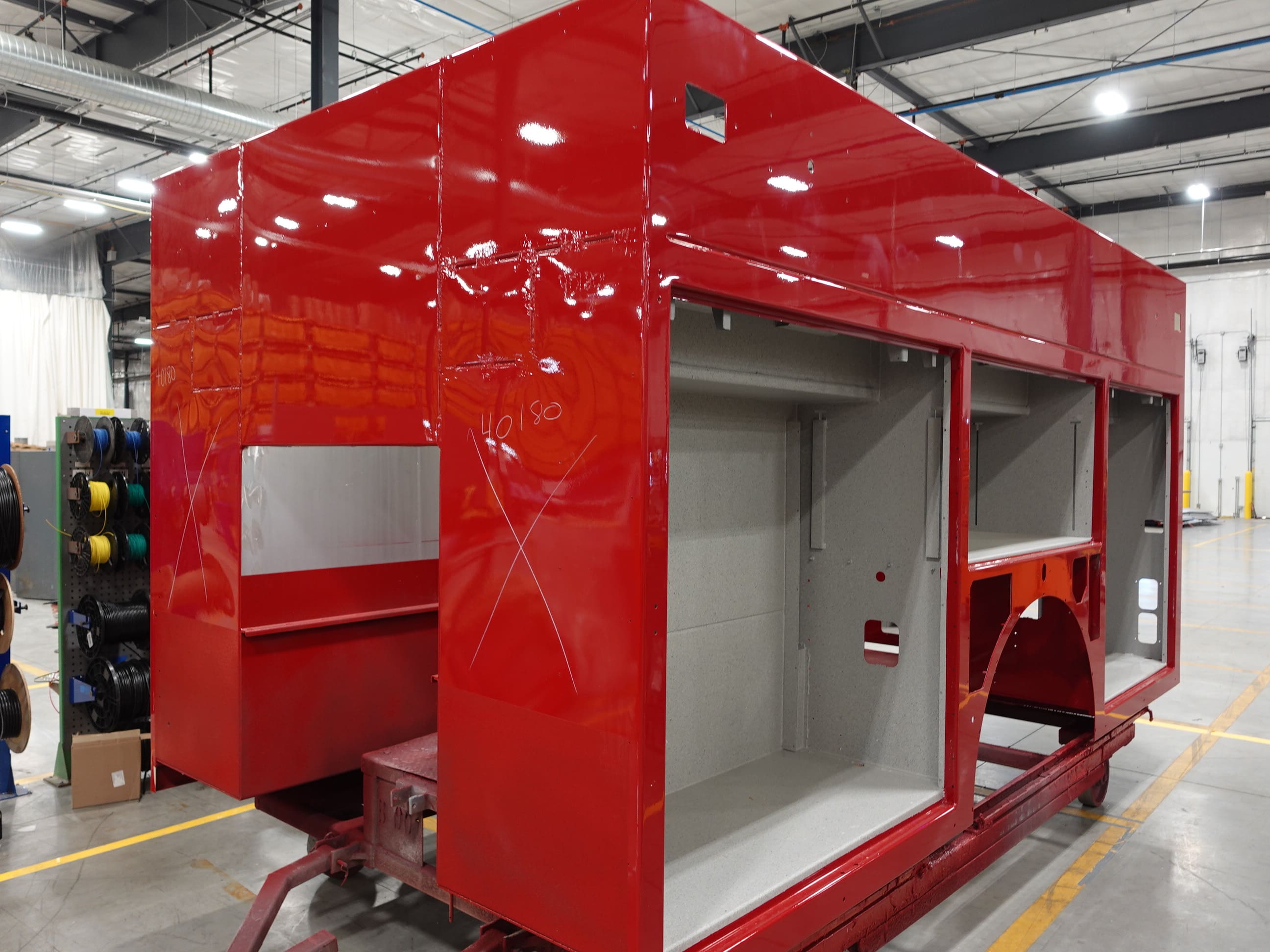

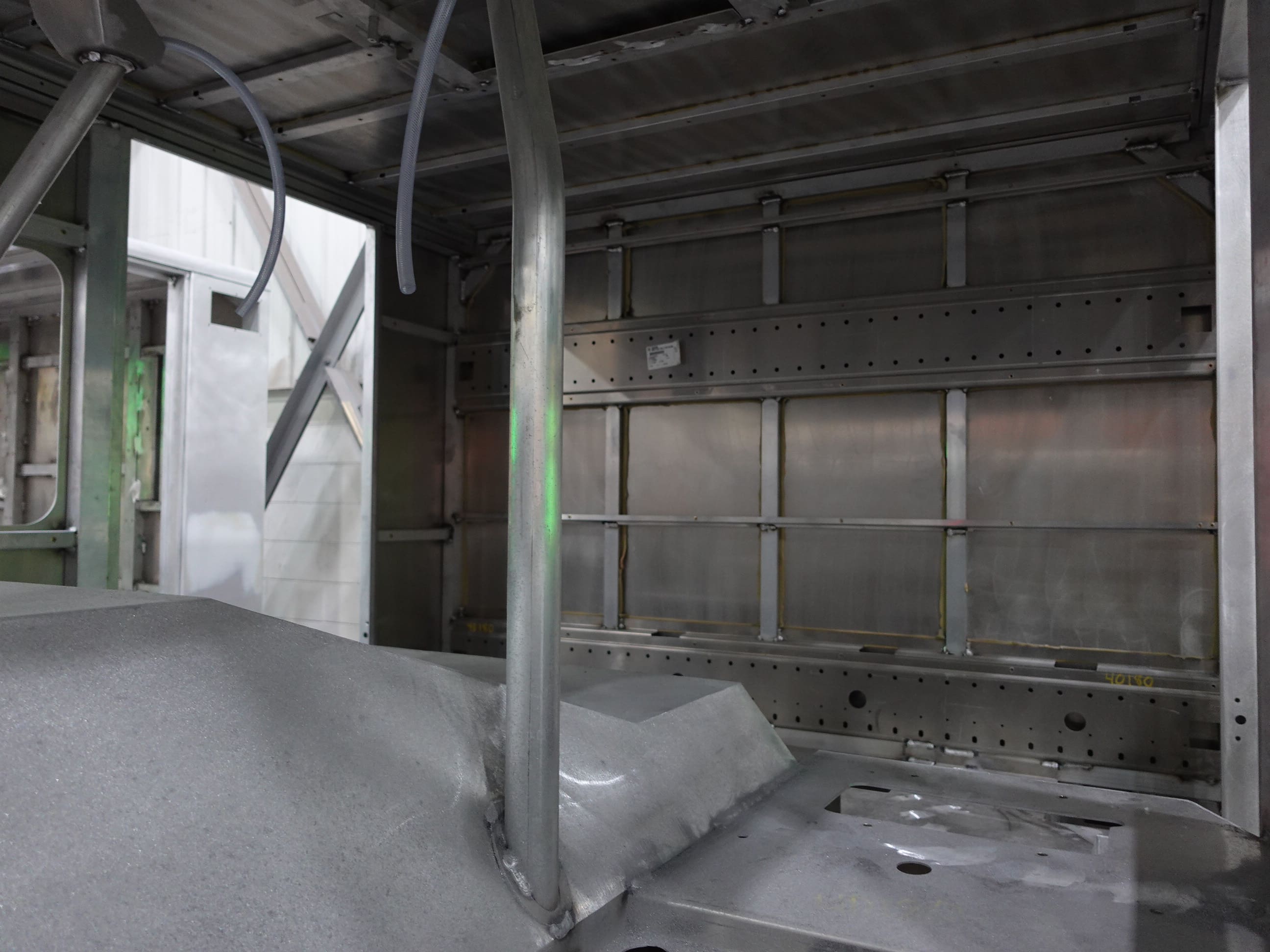

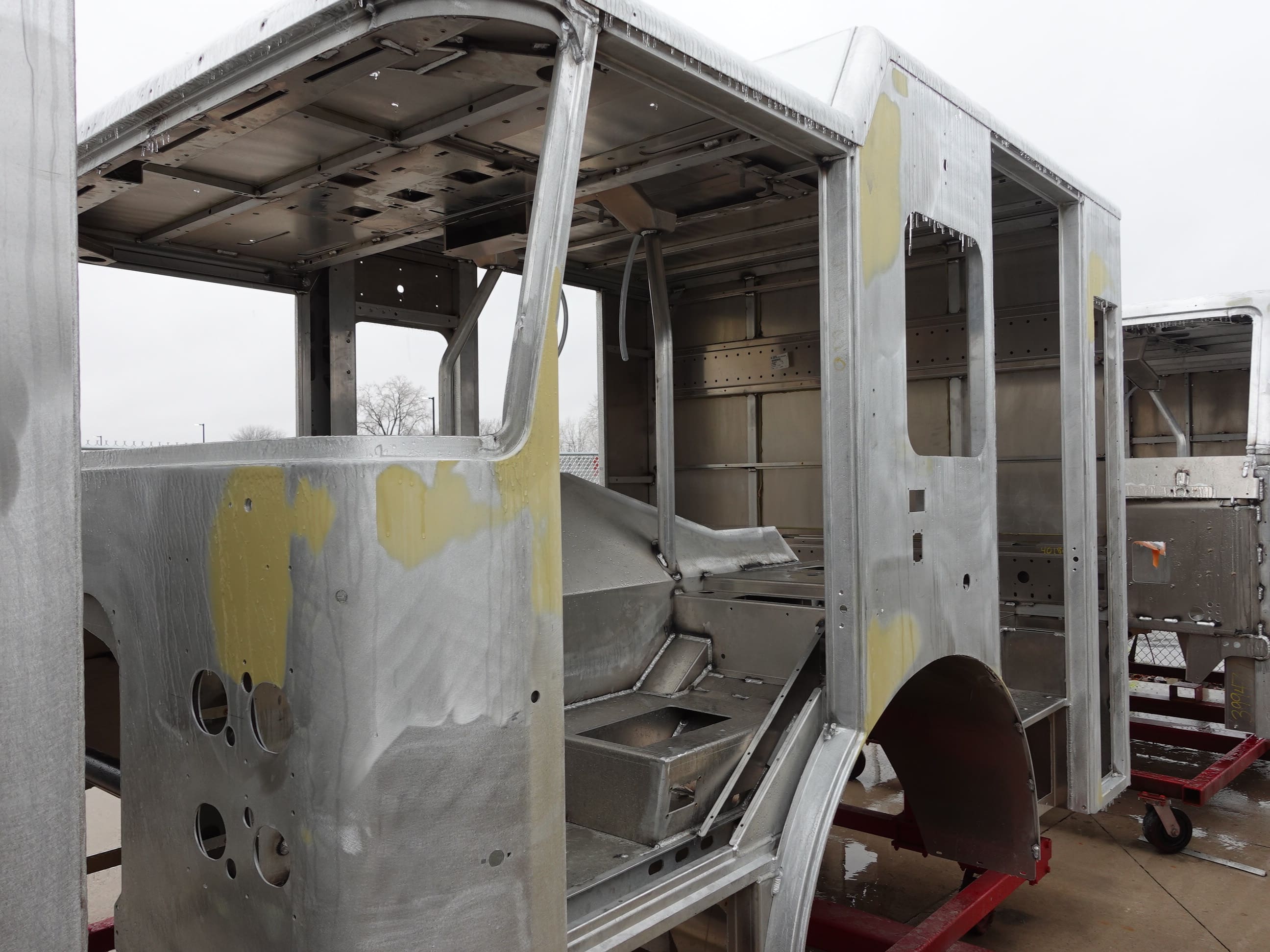

mounted, and the body completed paint and began initial

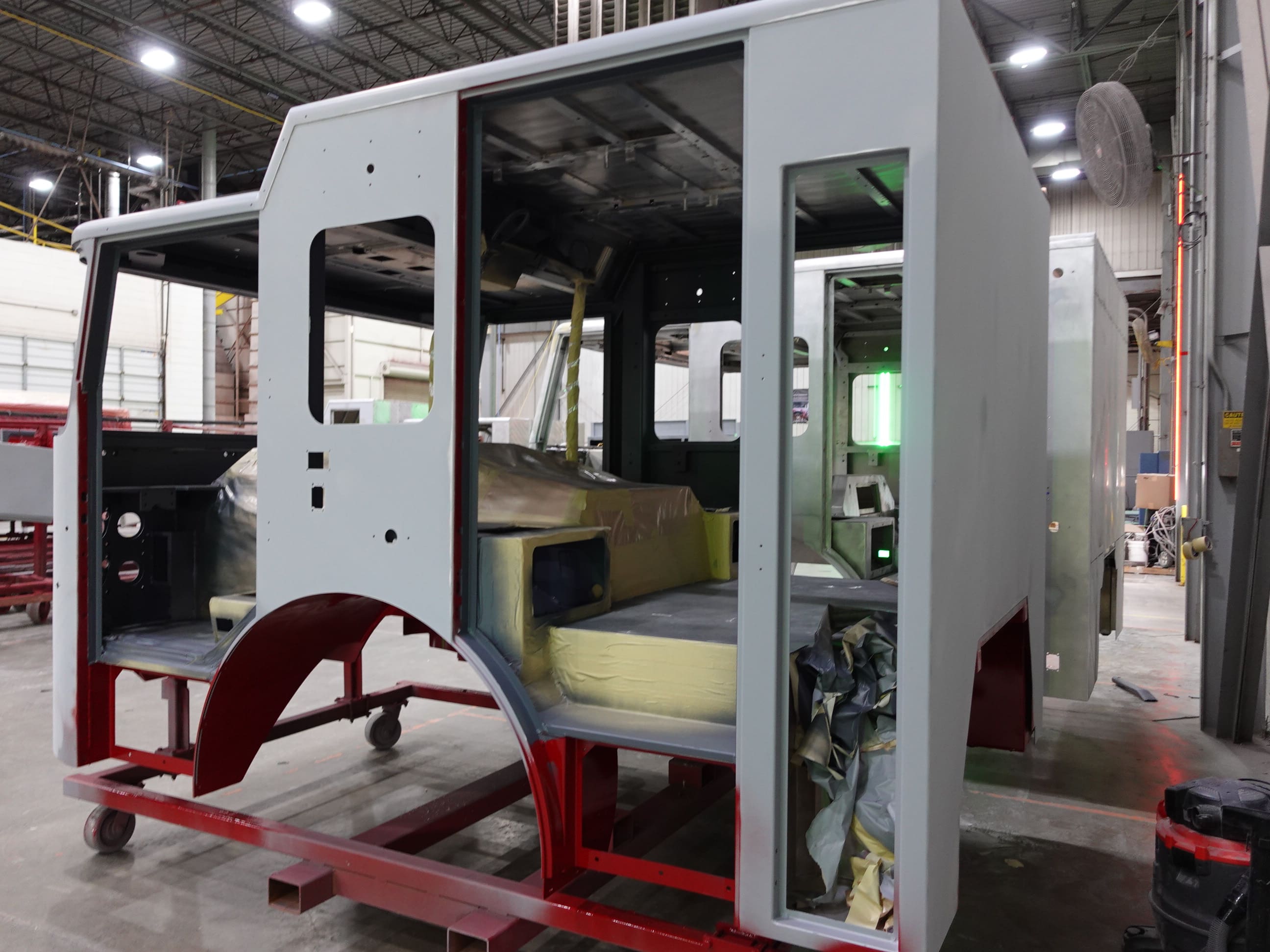

assembly.
05-22-26

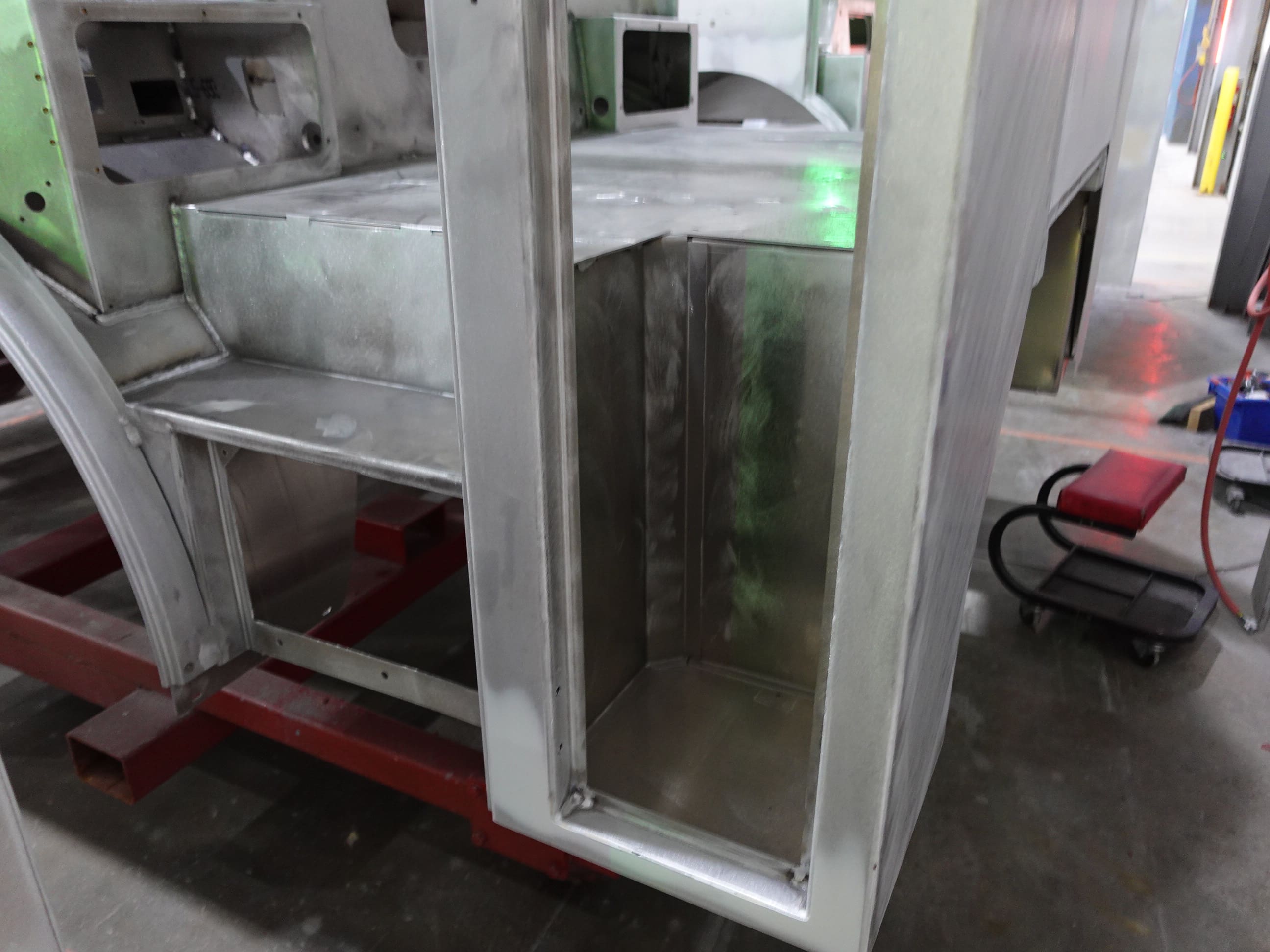

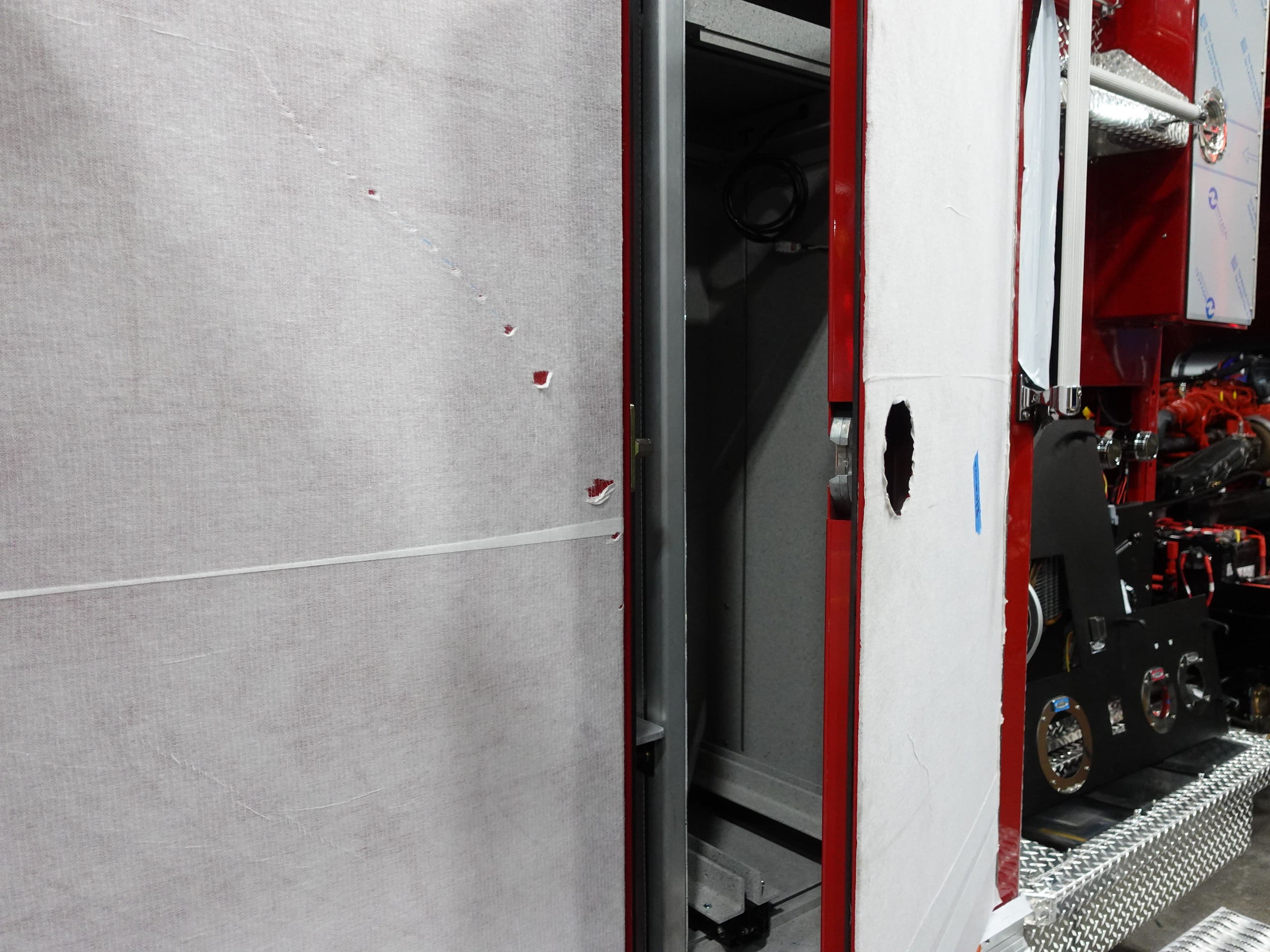

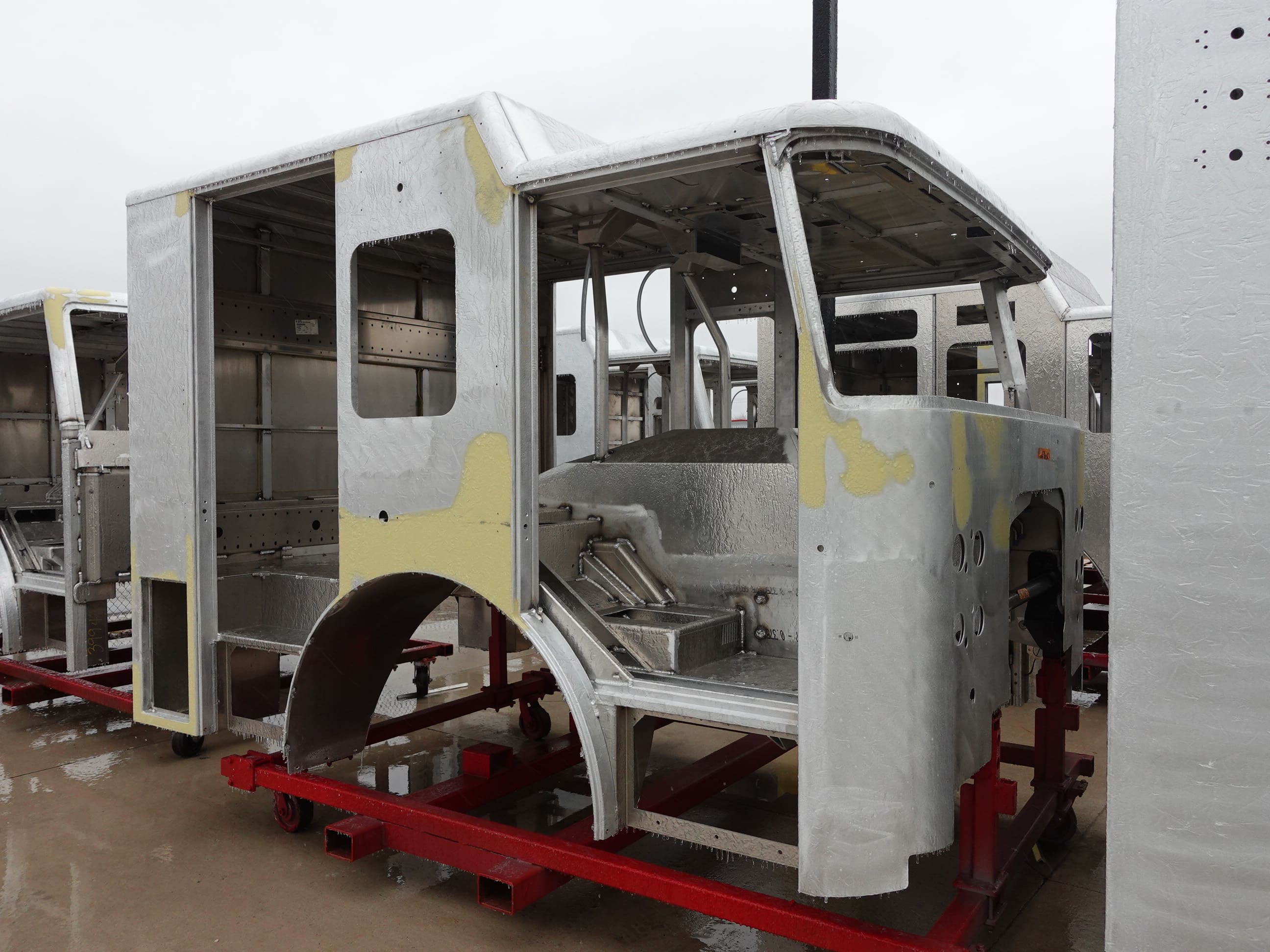

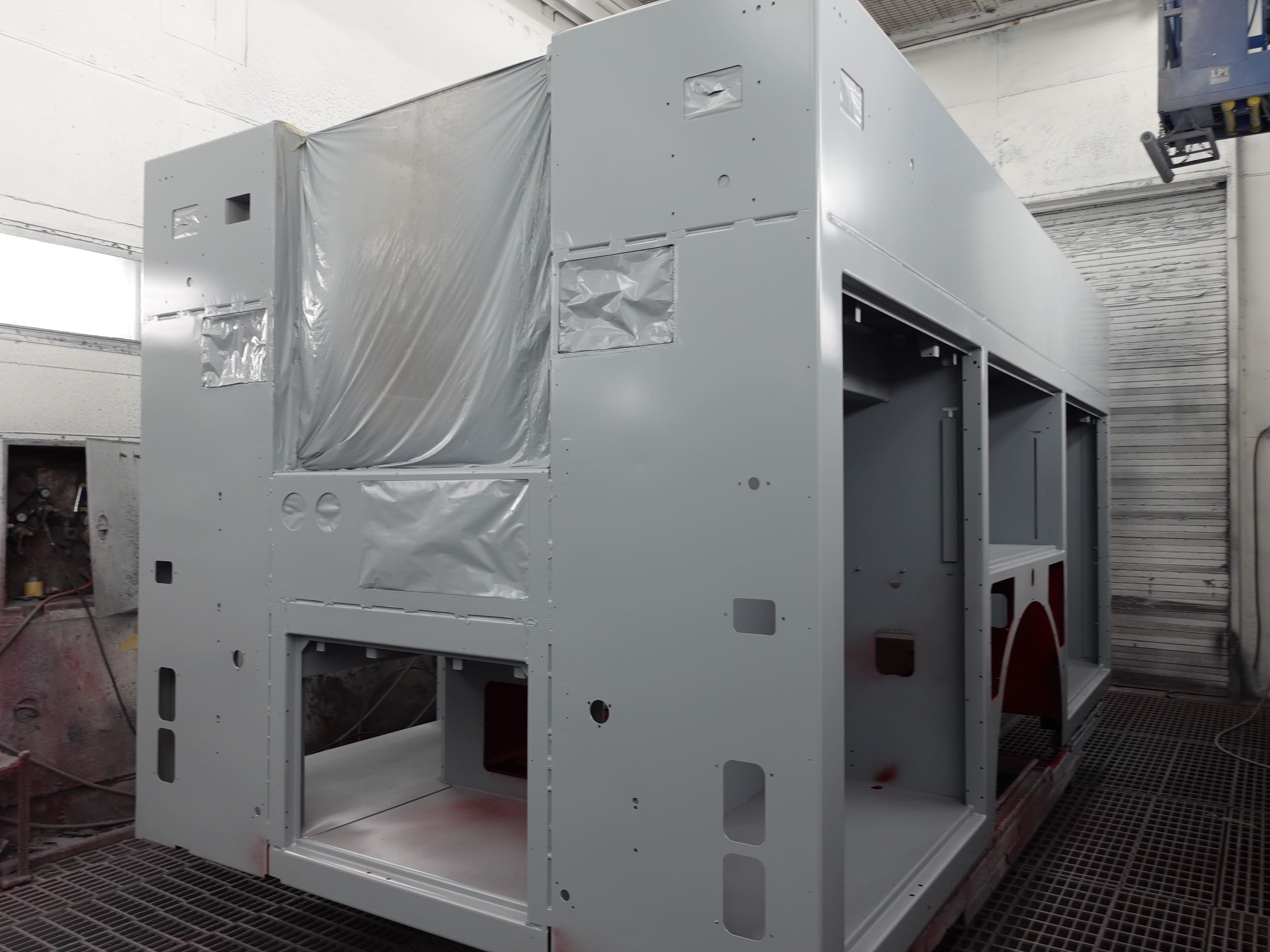

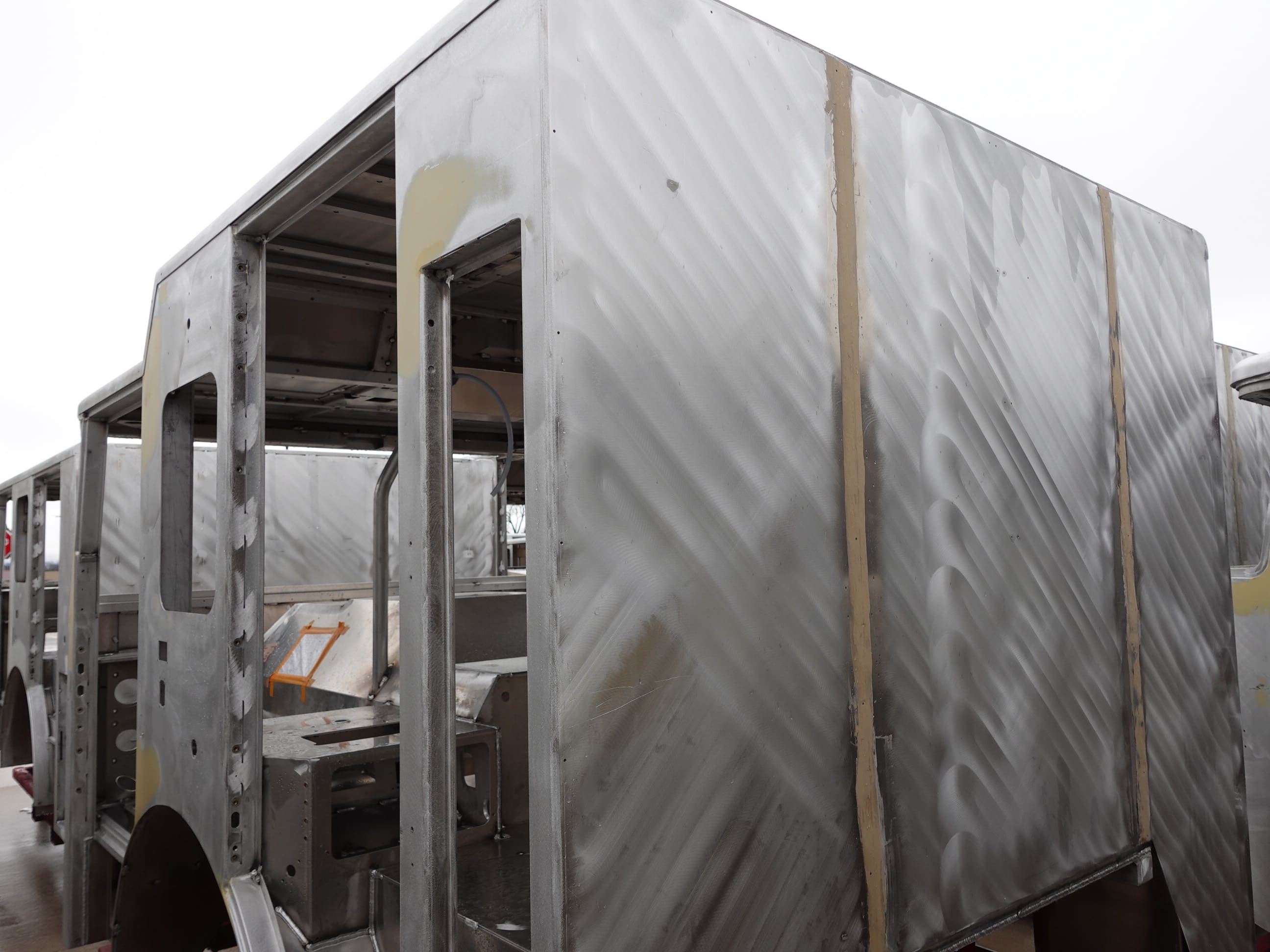

In this report, the cab began initial assembly, the frame build continued, the pump house continued initial assembly, and the body continued through paint.

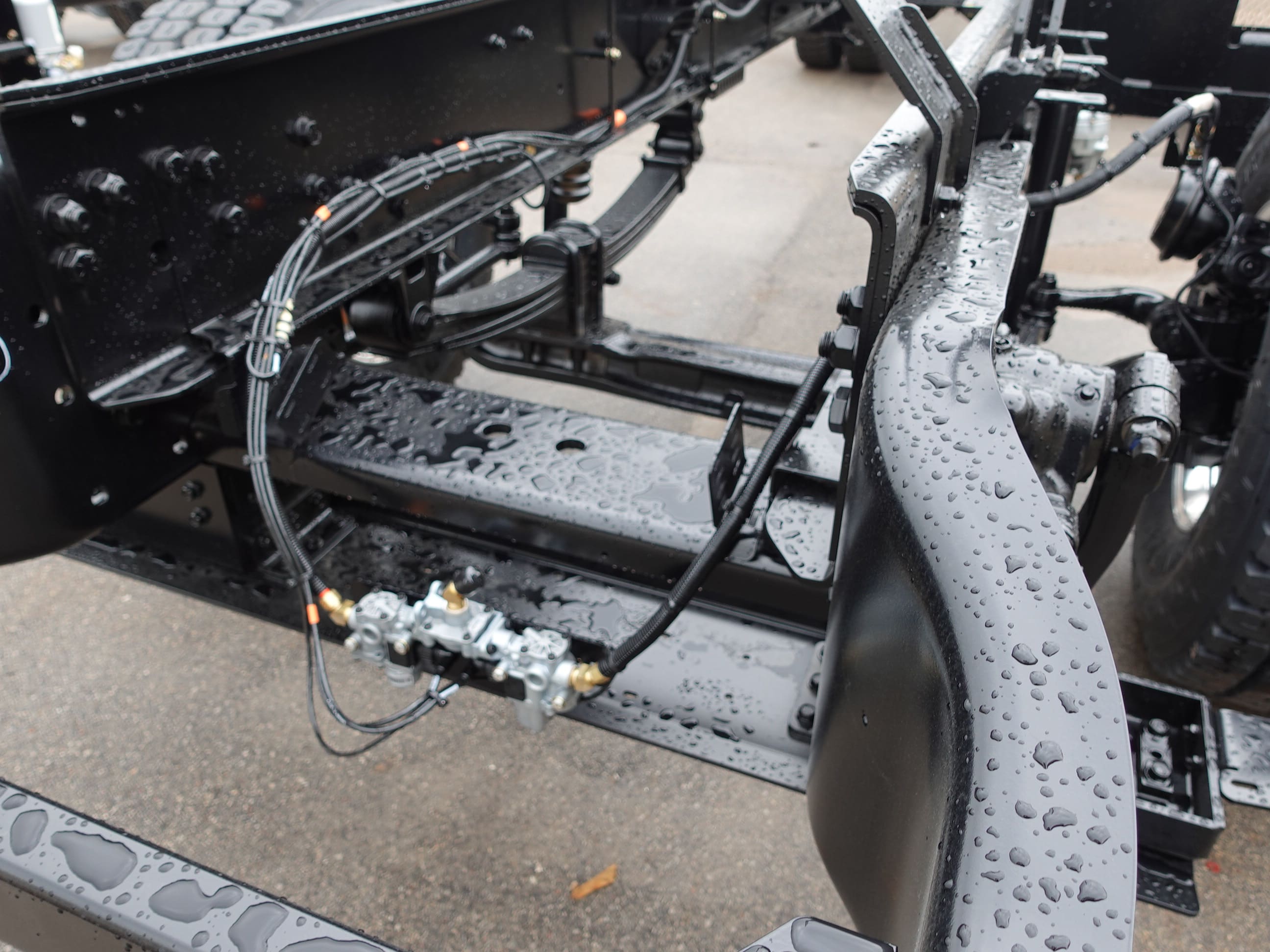

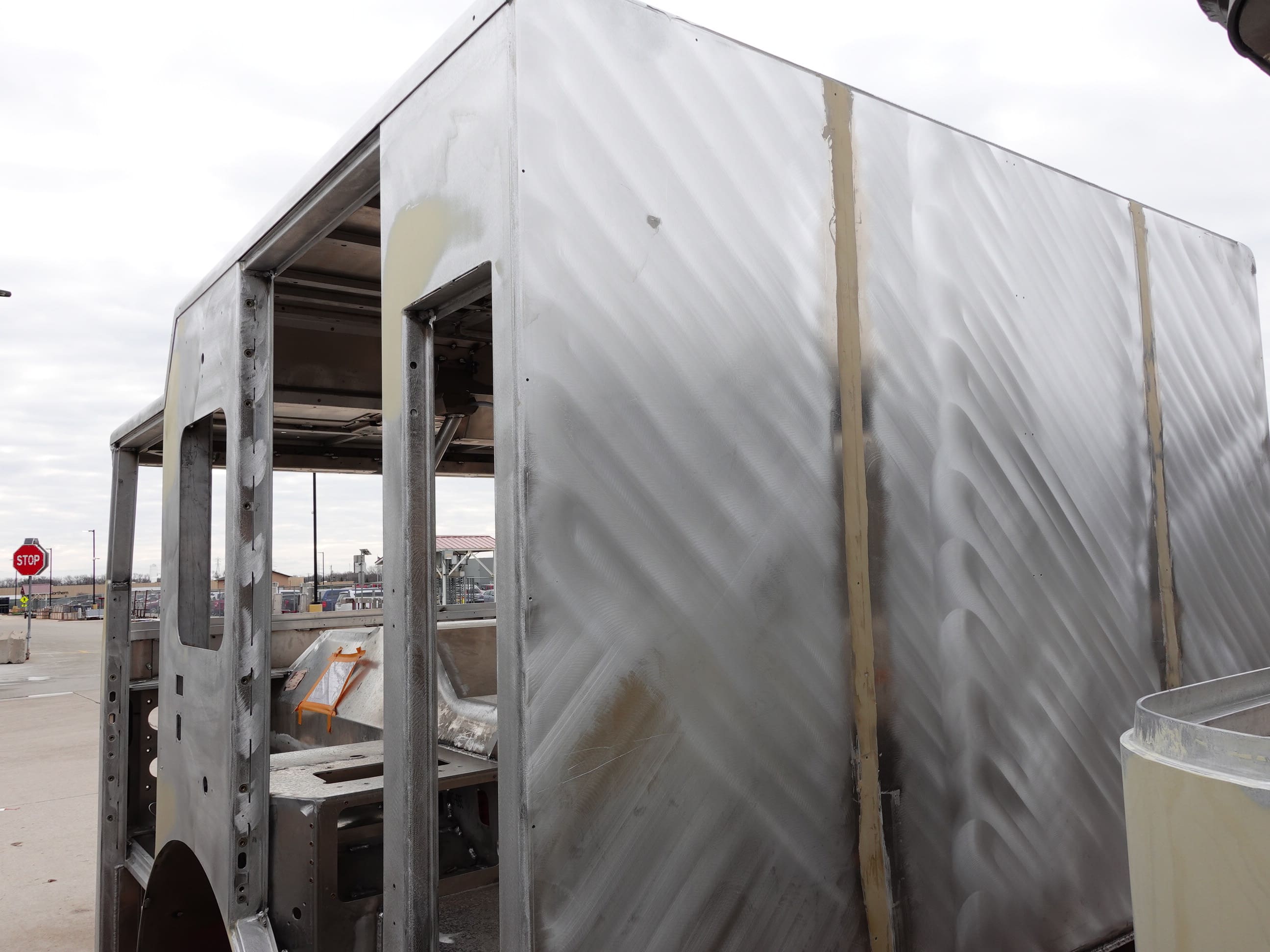

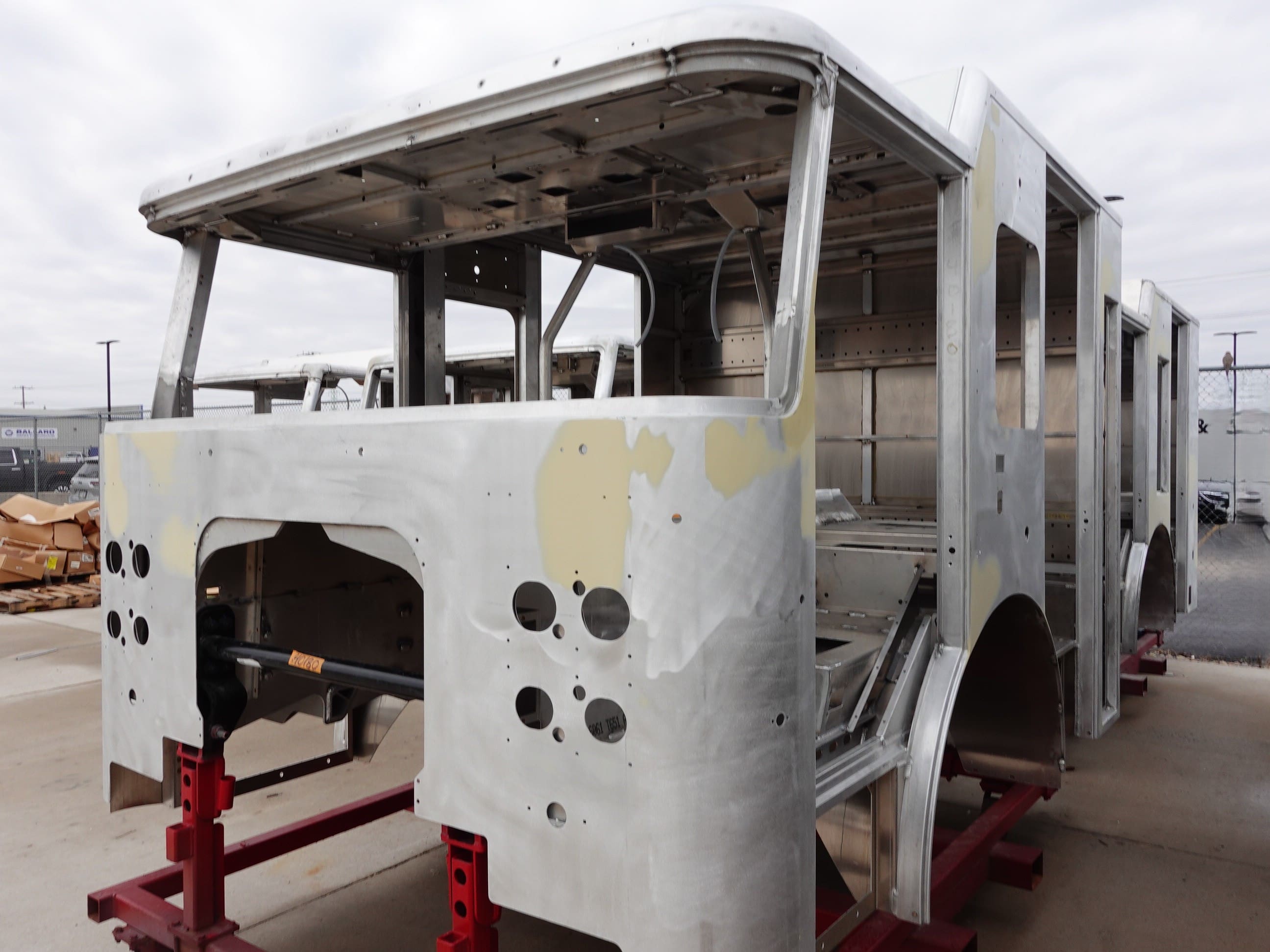

05-15-26

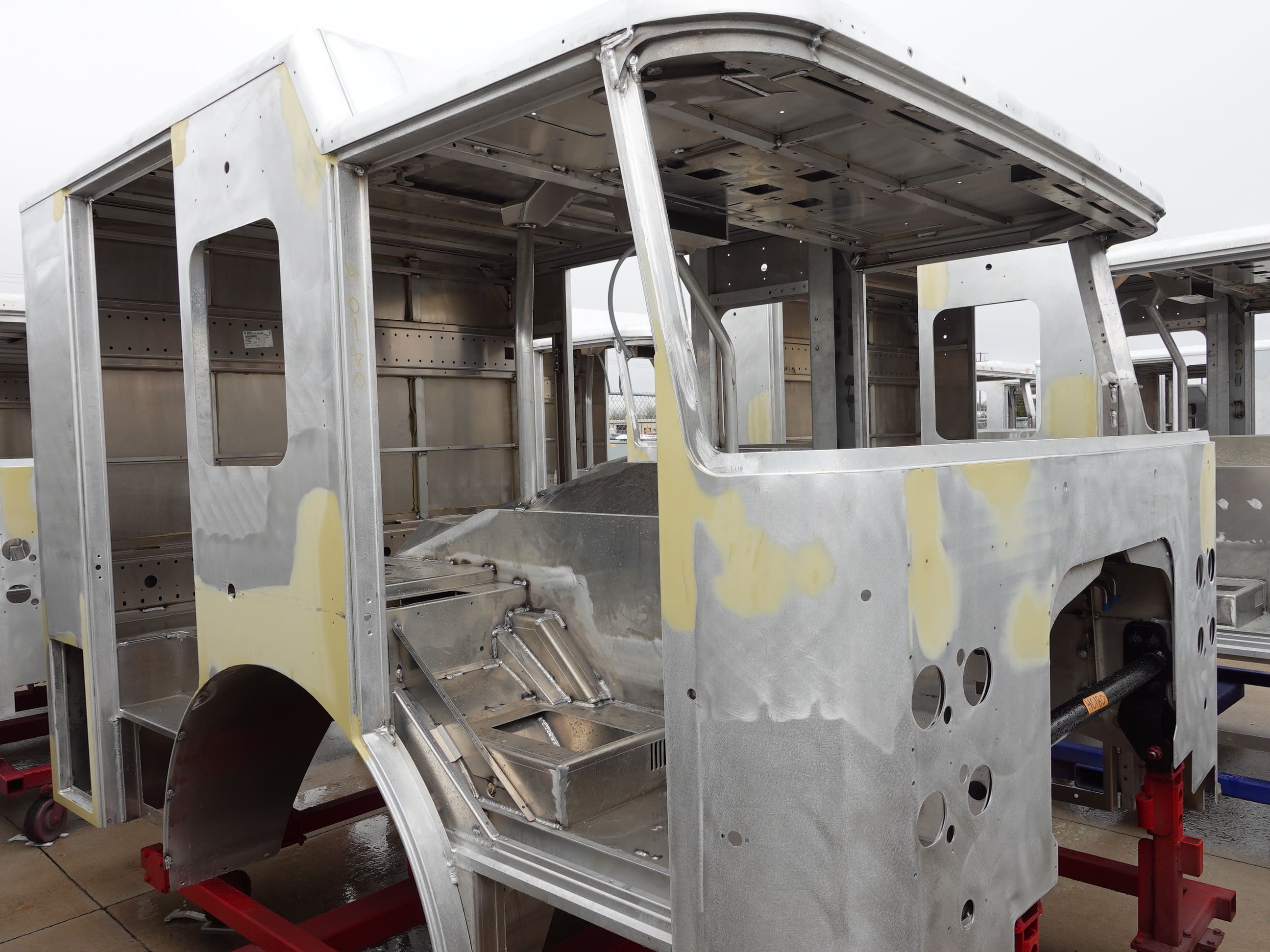

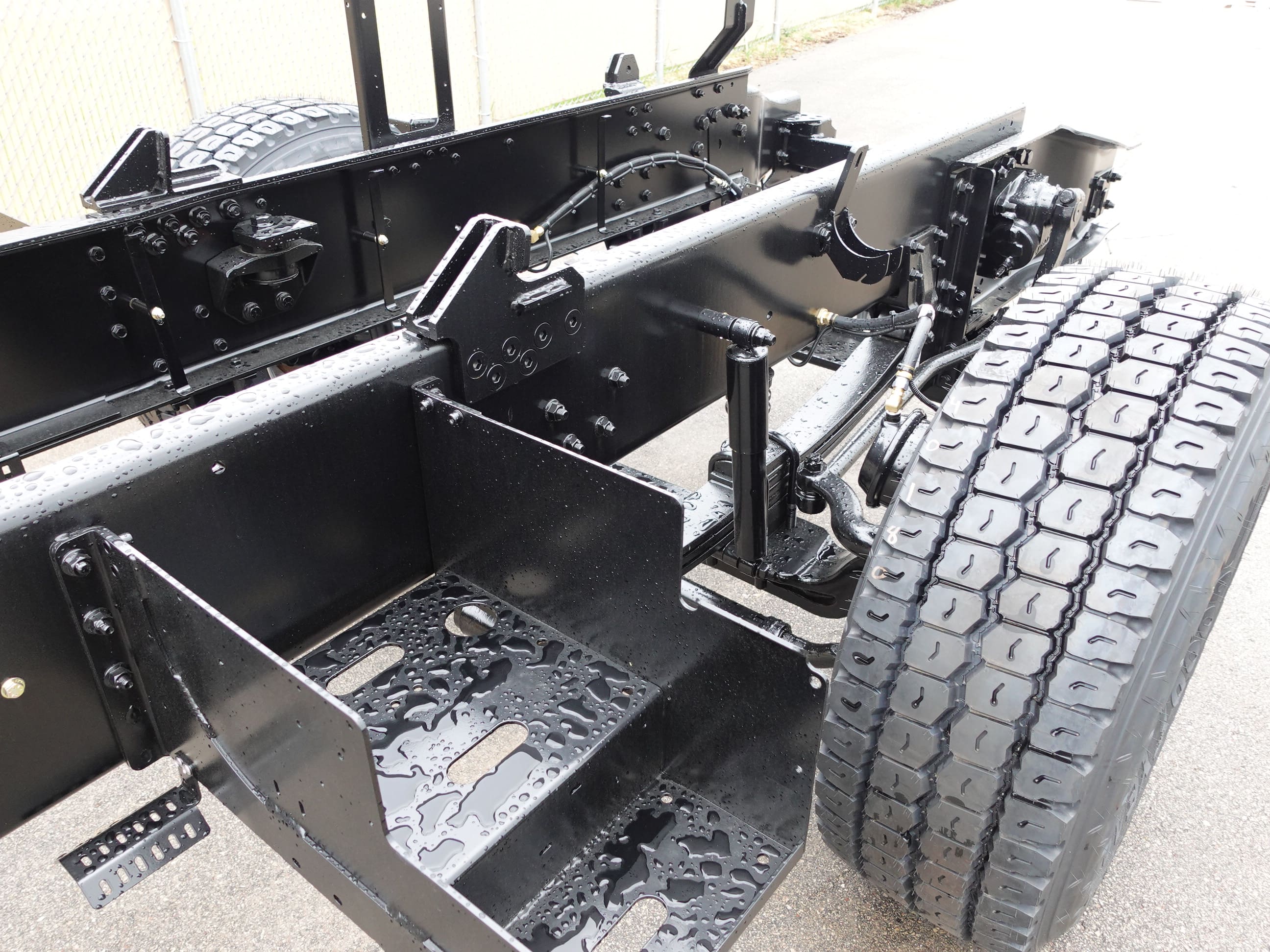

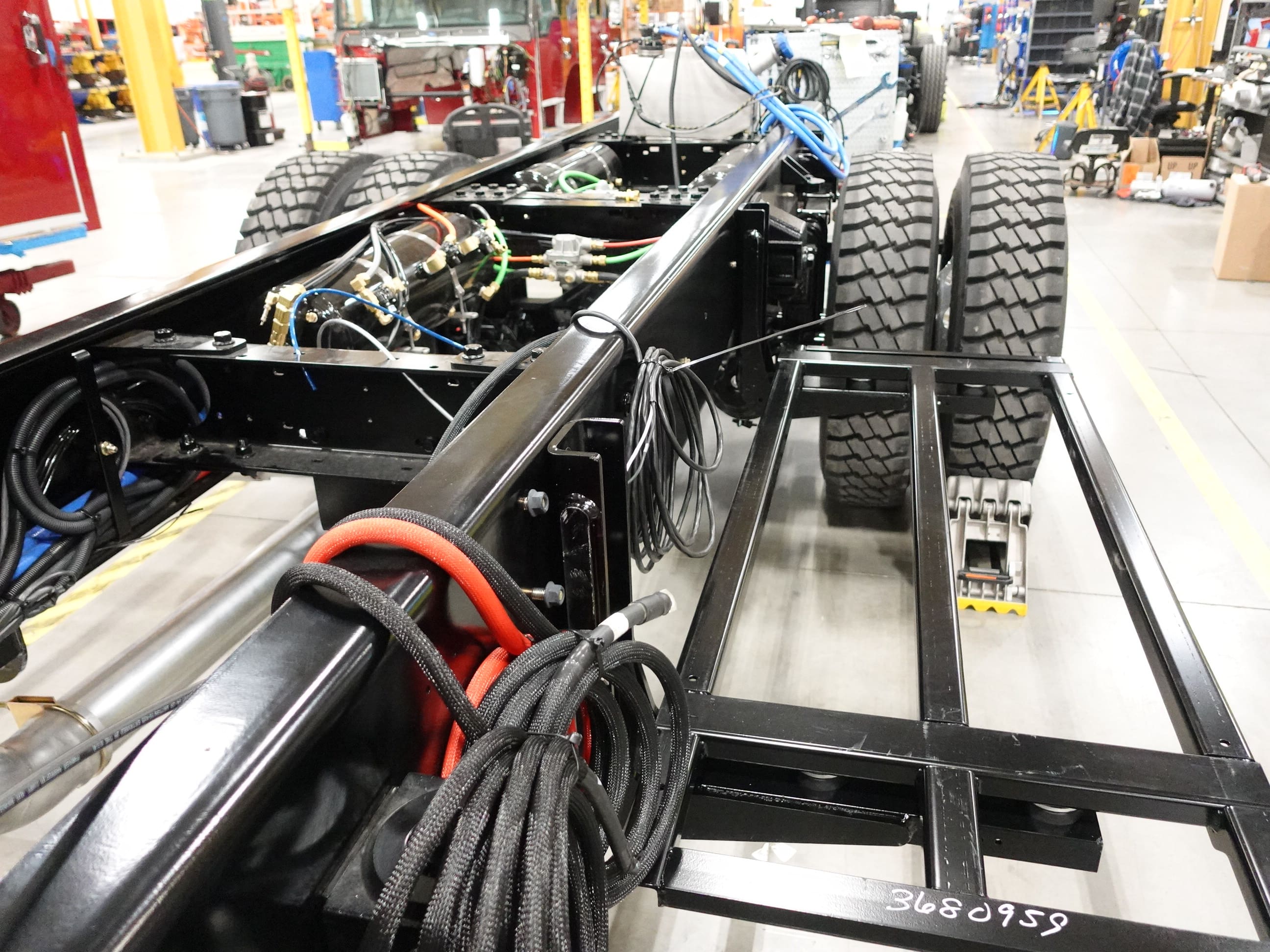

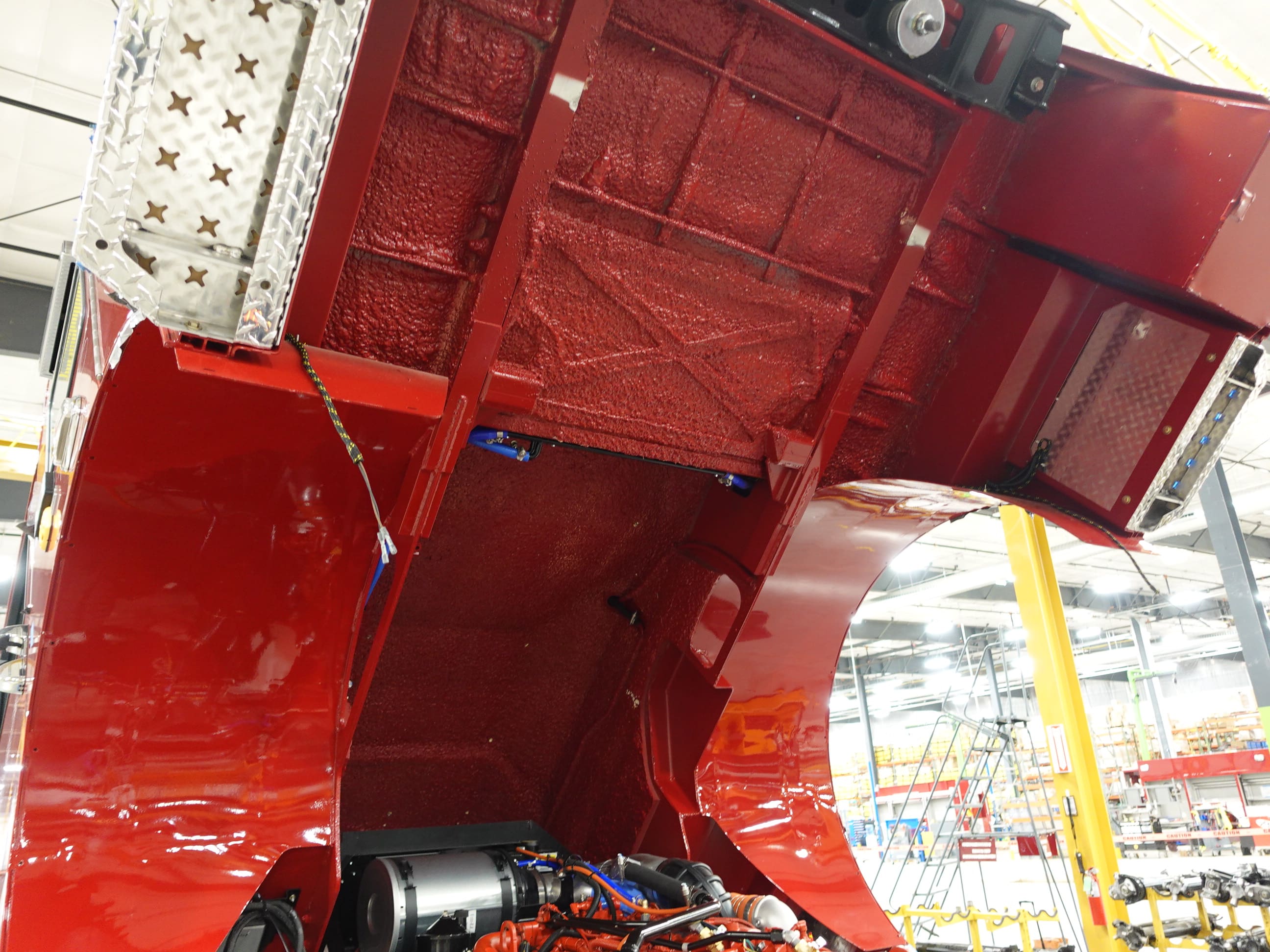

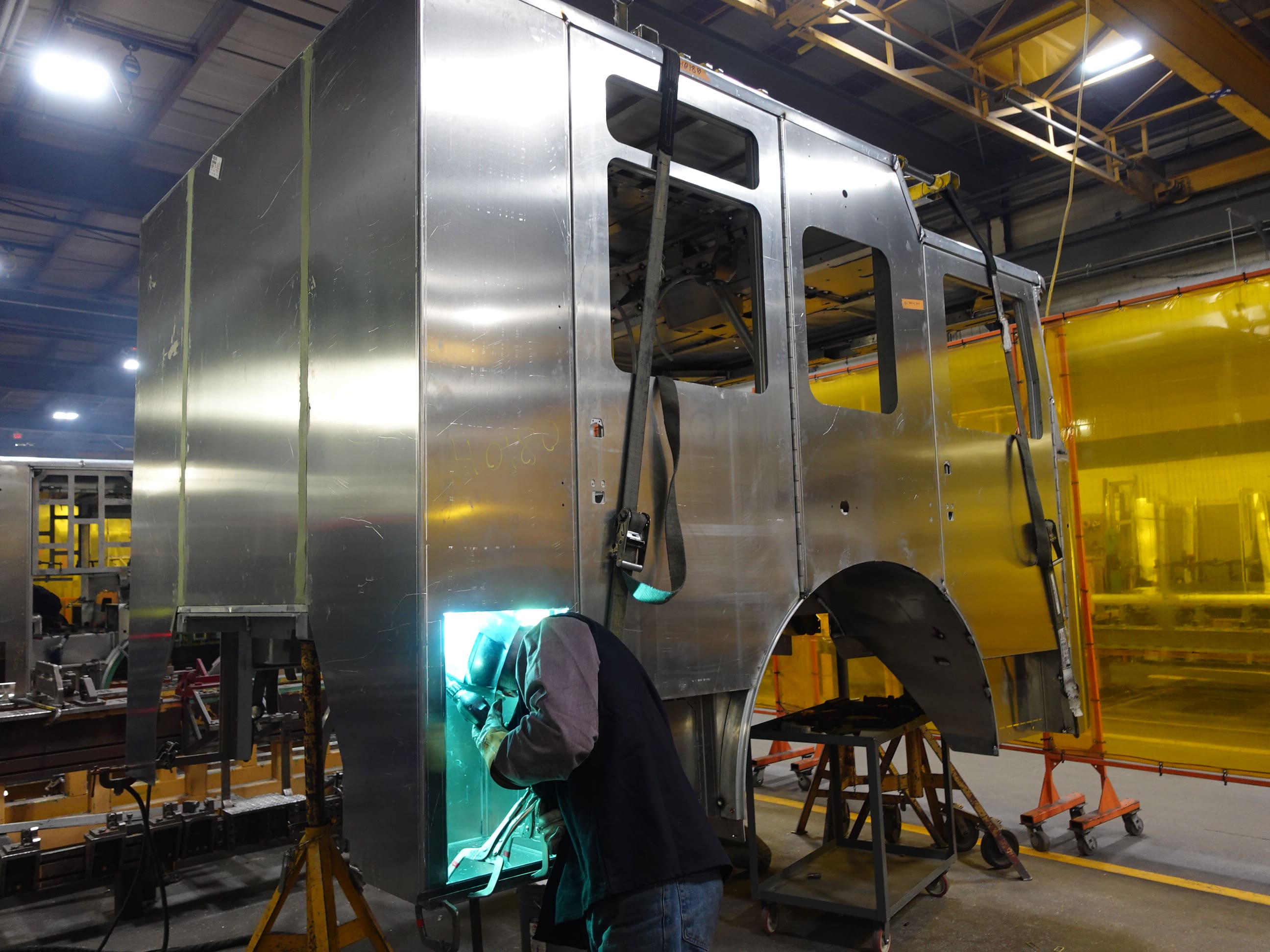

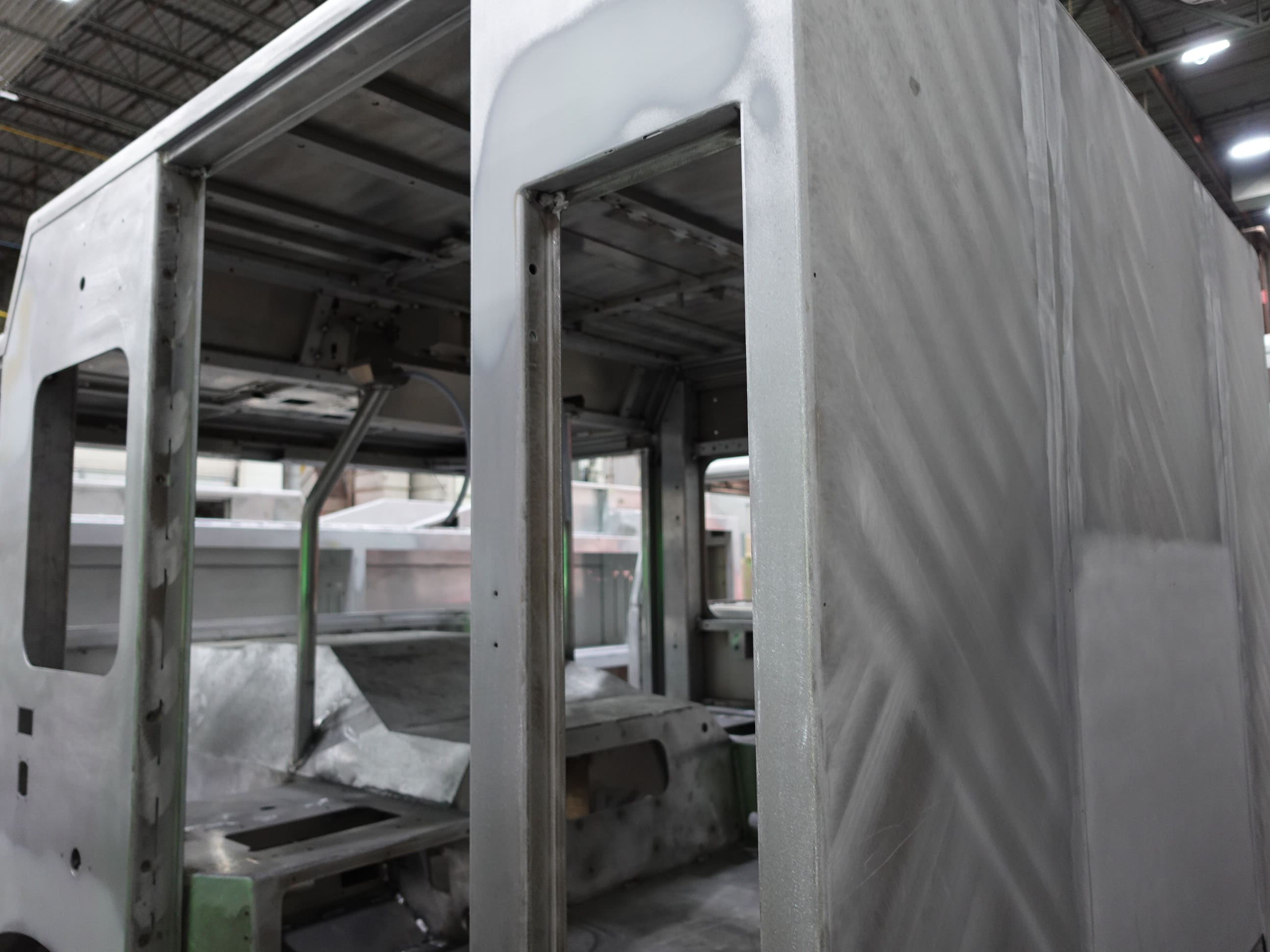

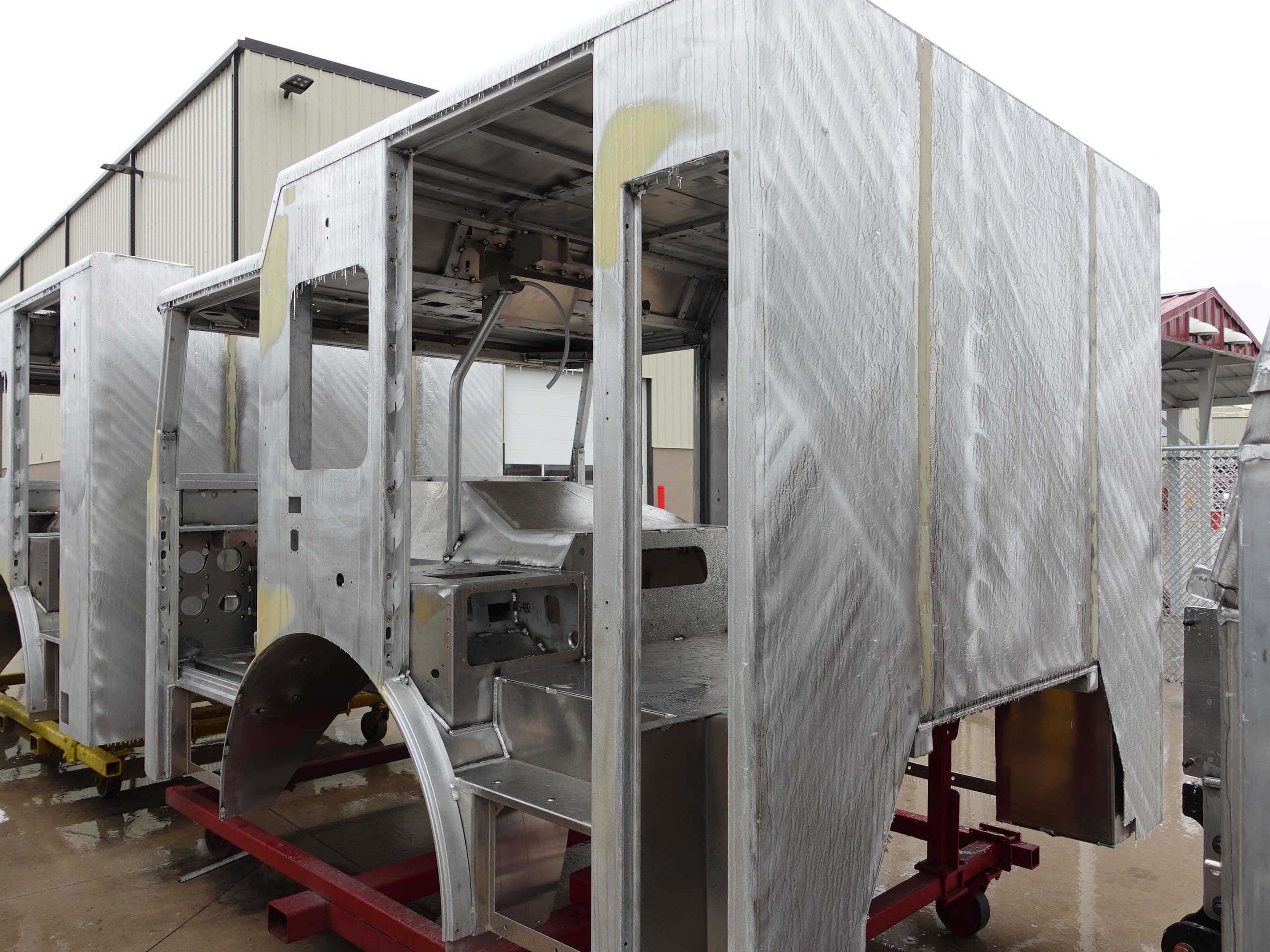

In this report, the cab was offsite having protective

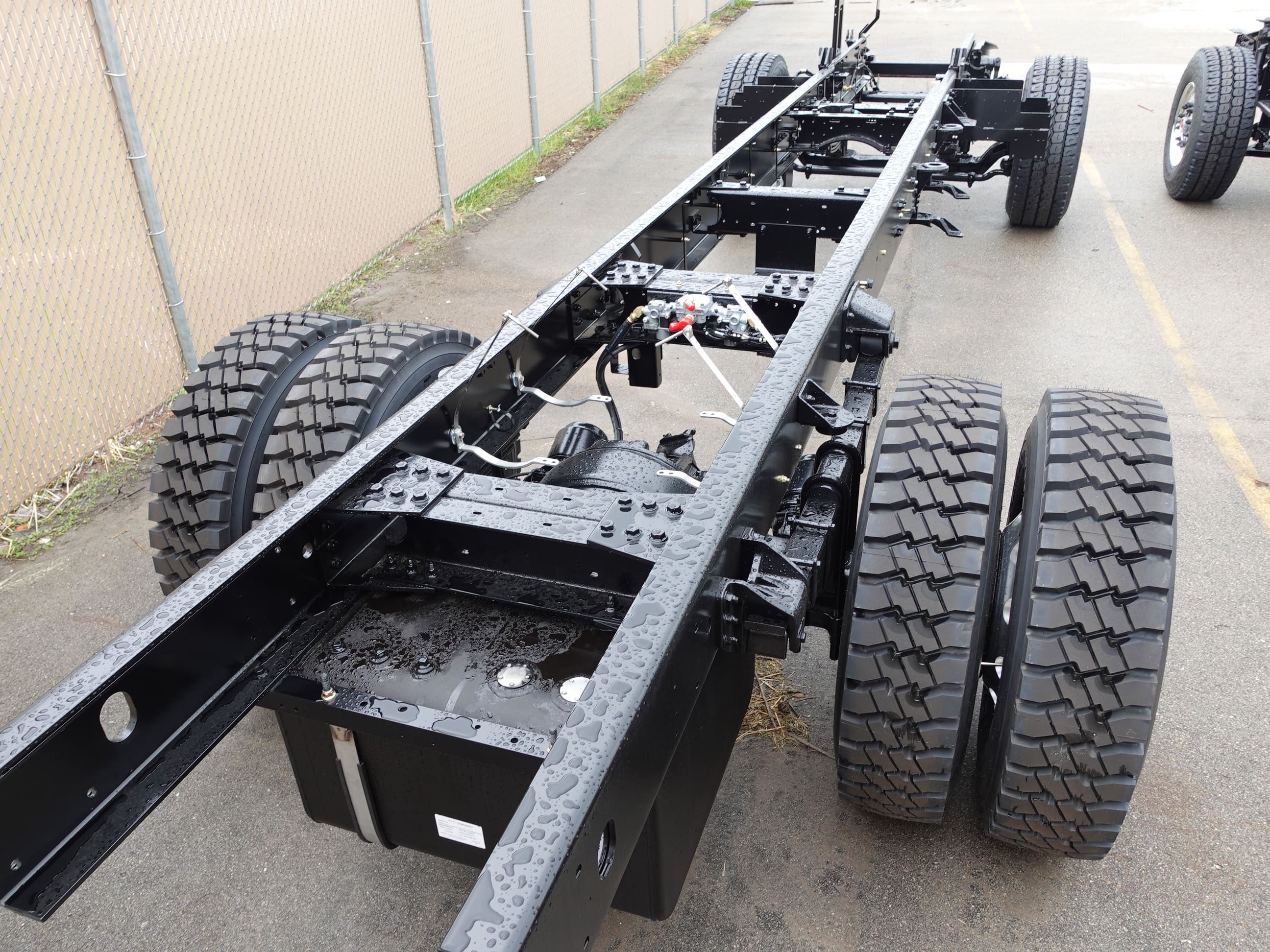

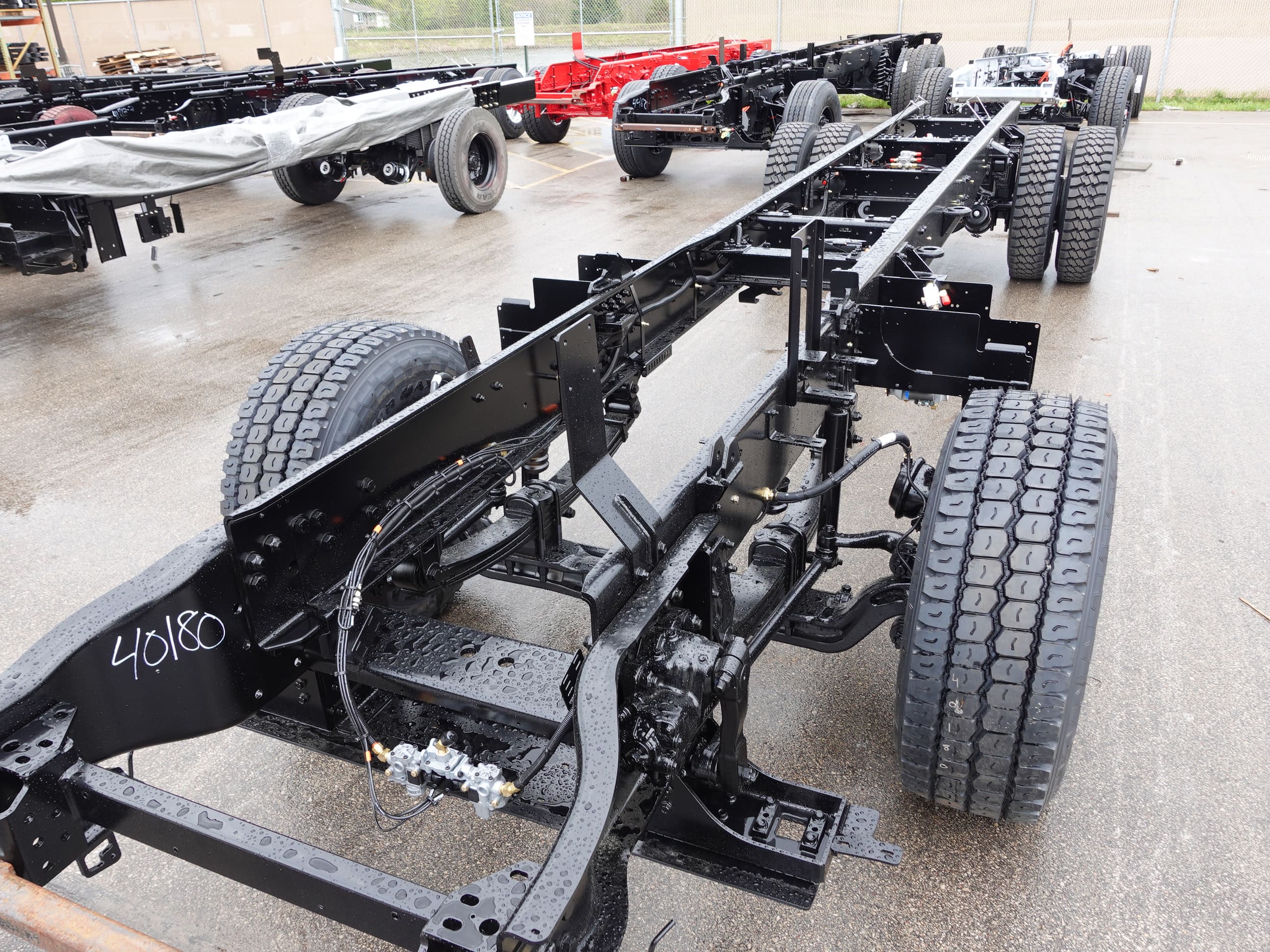

coating applied, the frame build began, the pump house

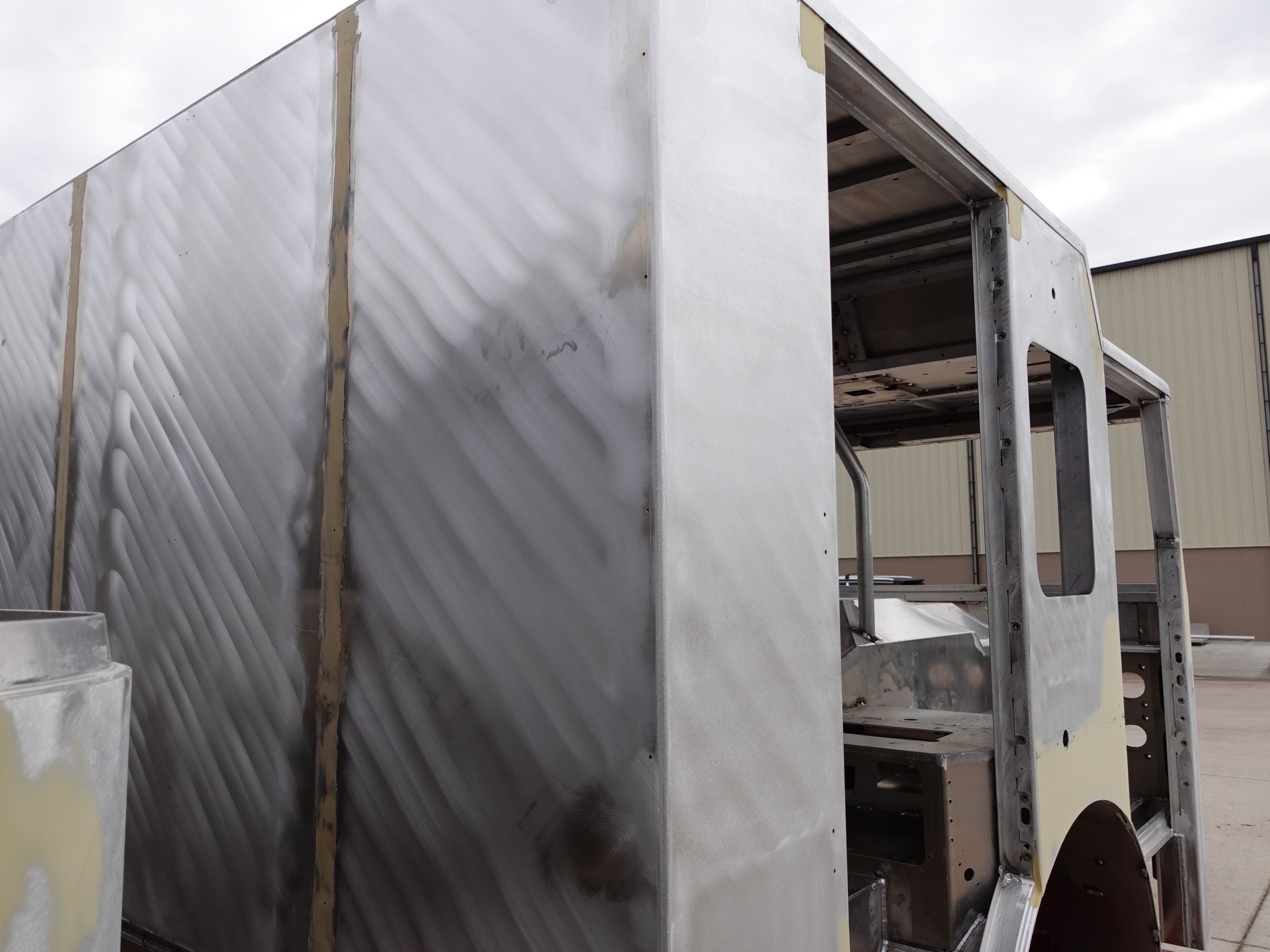

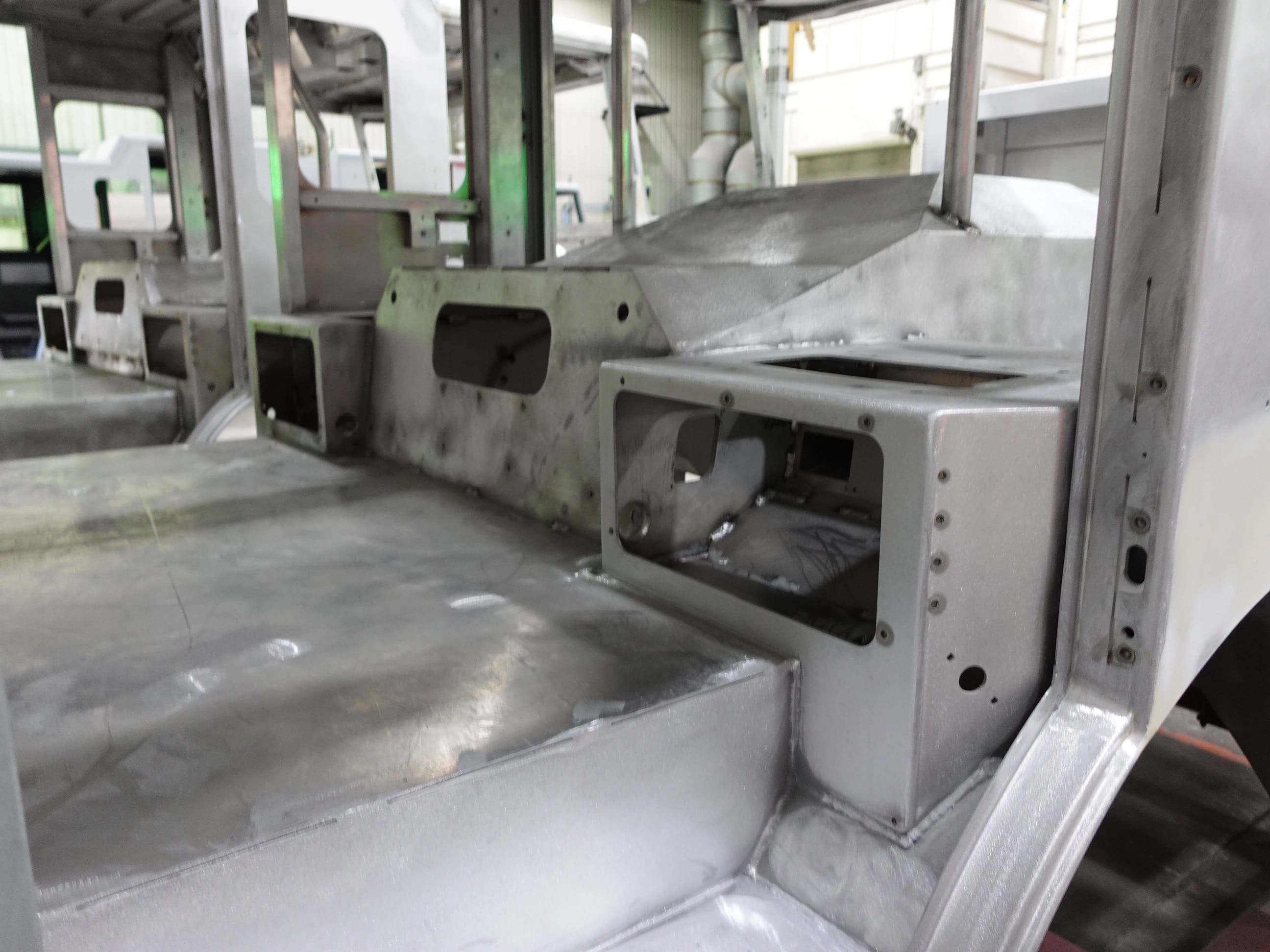

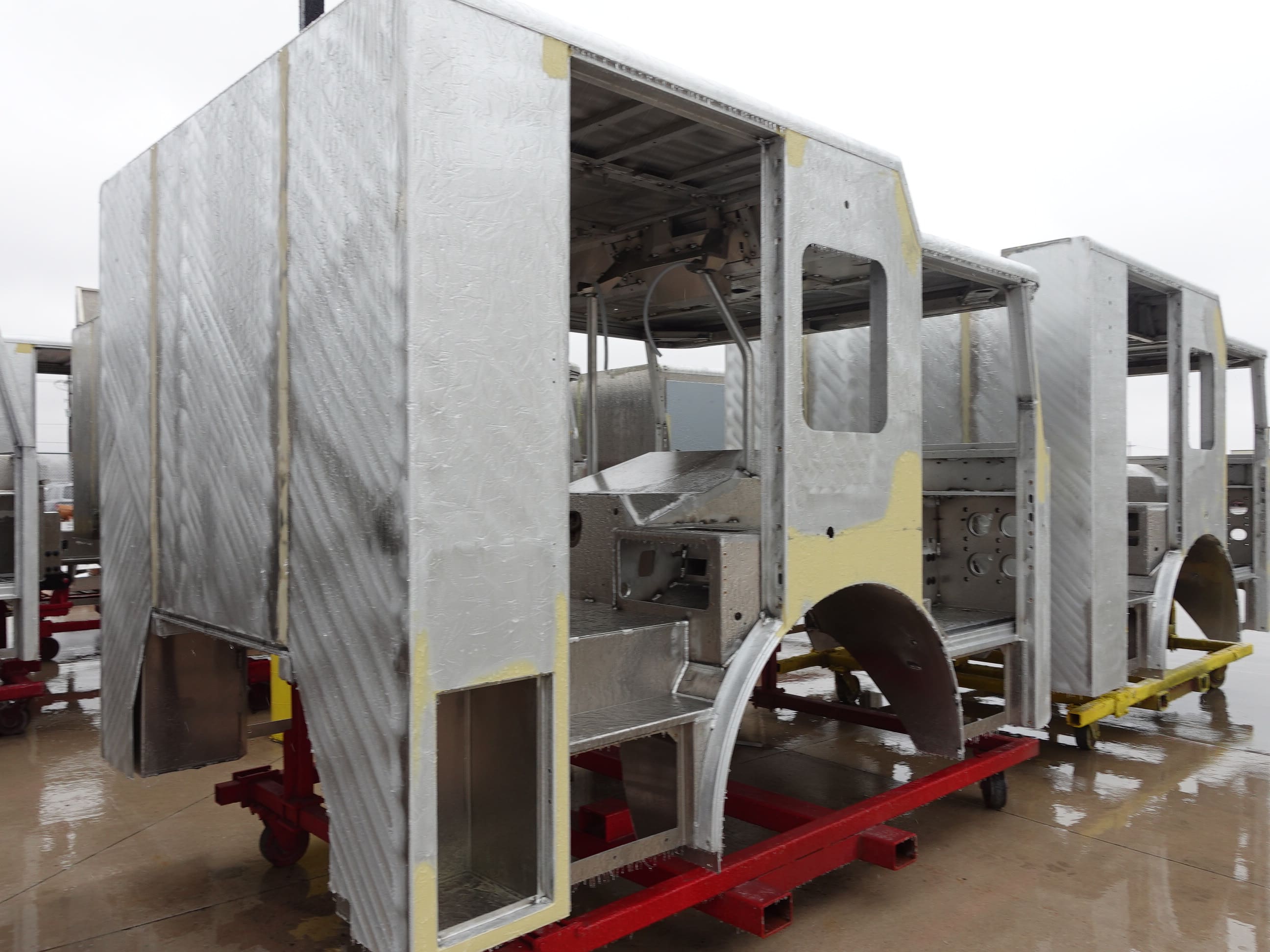

began initial assembly, and the body was fabricated and
began the paint process.
