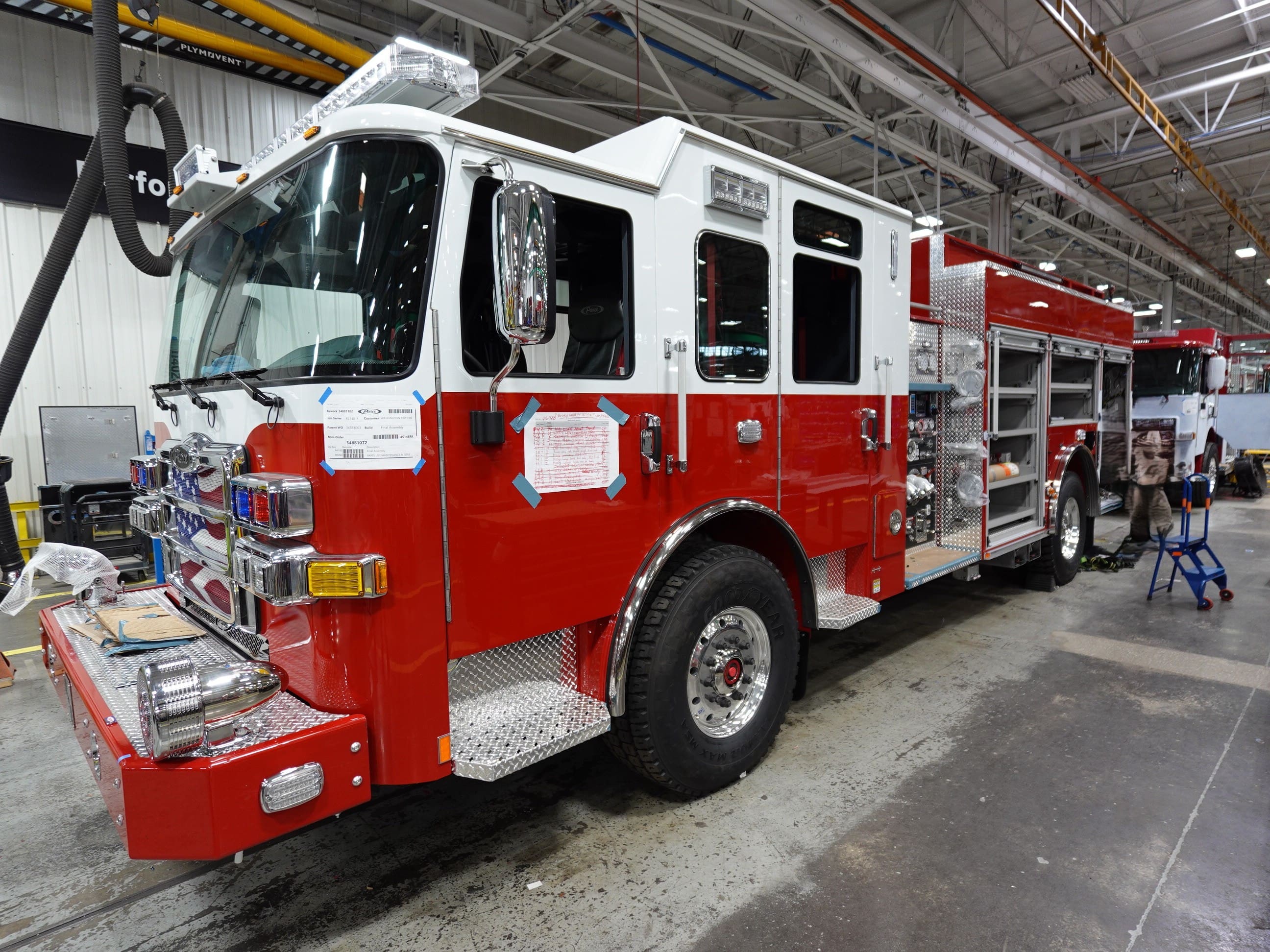

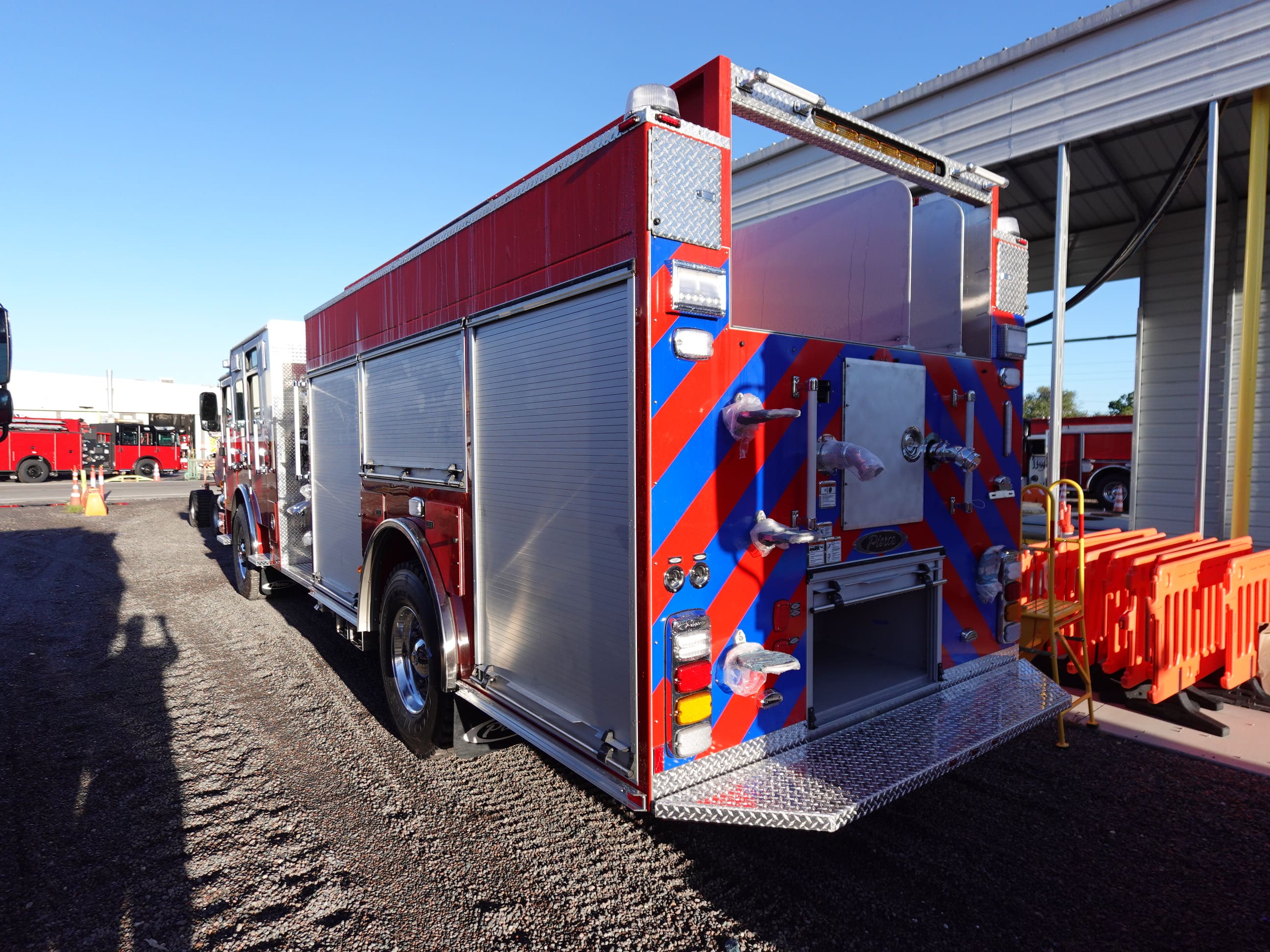

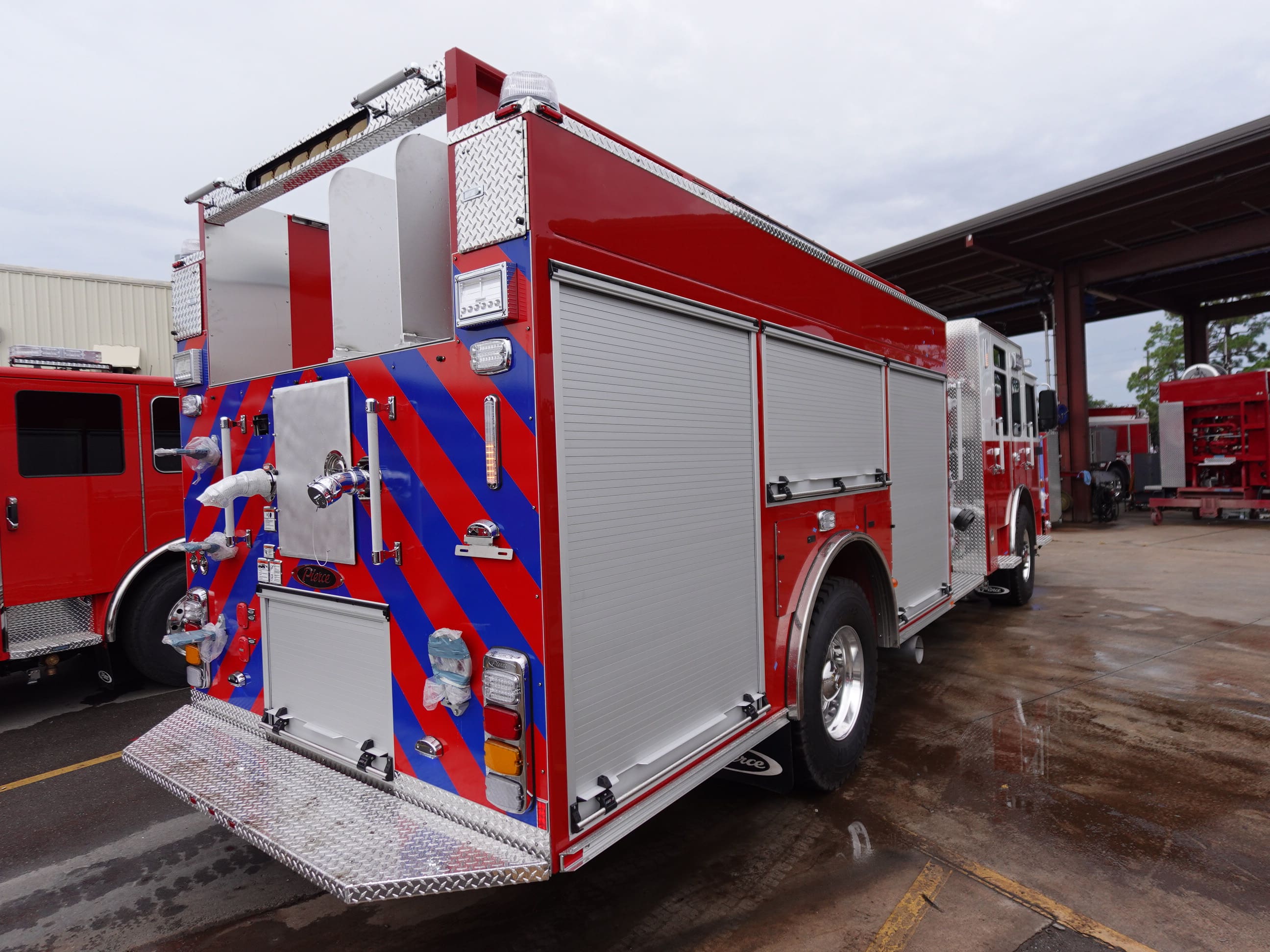

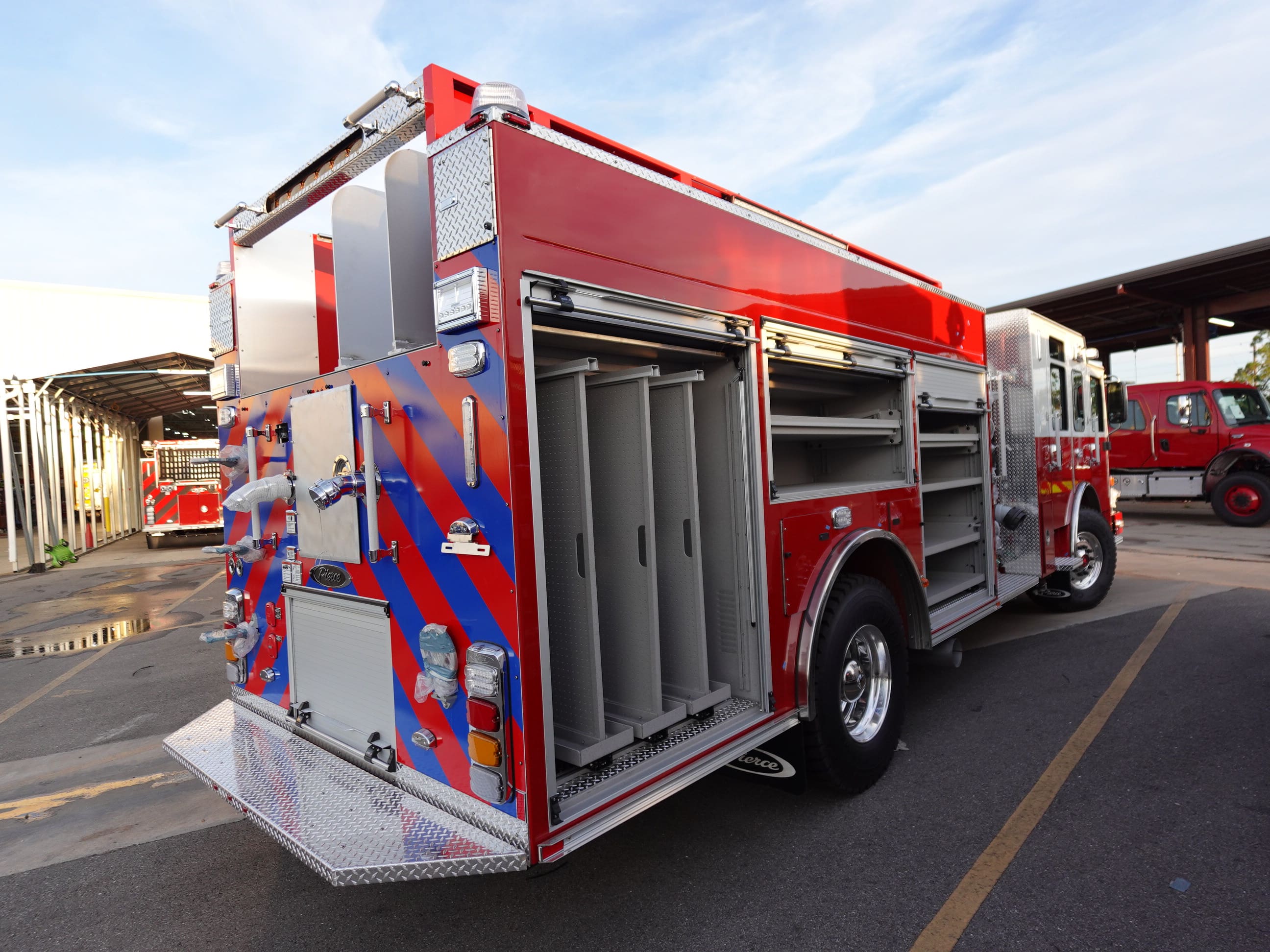

10-09-26

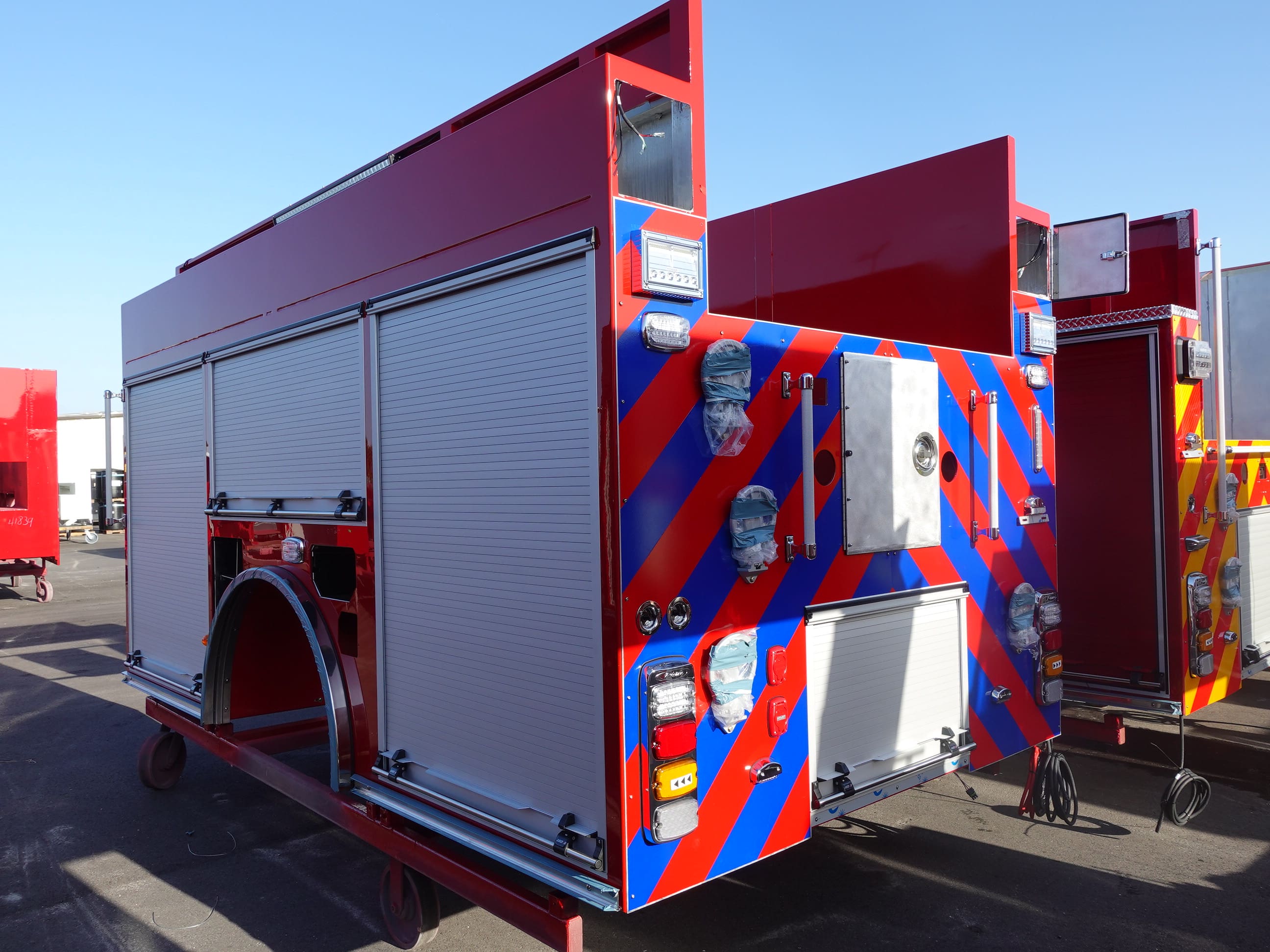

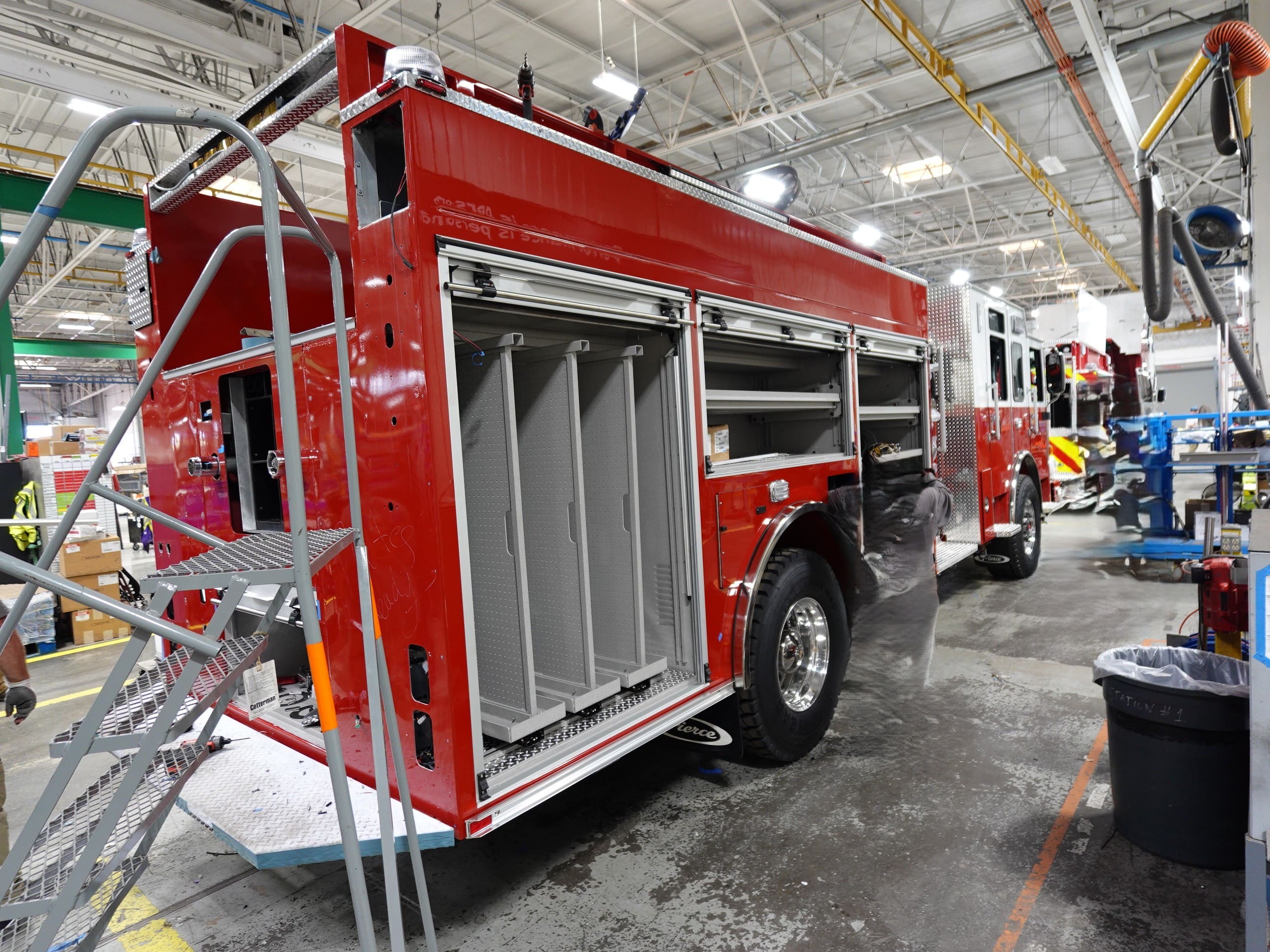

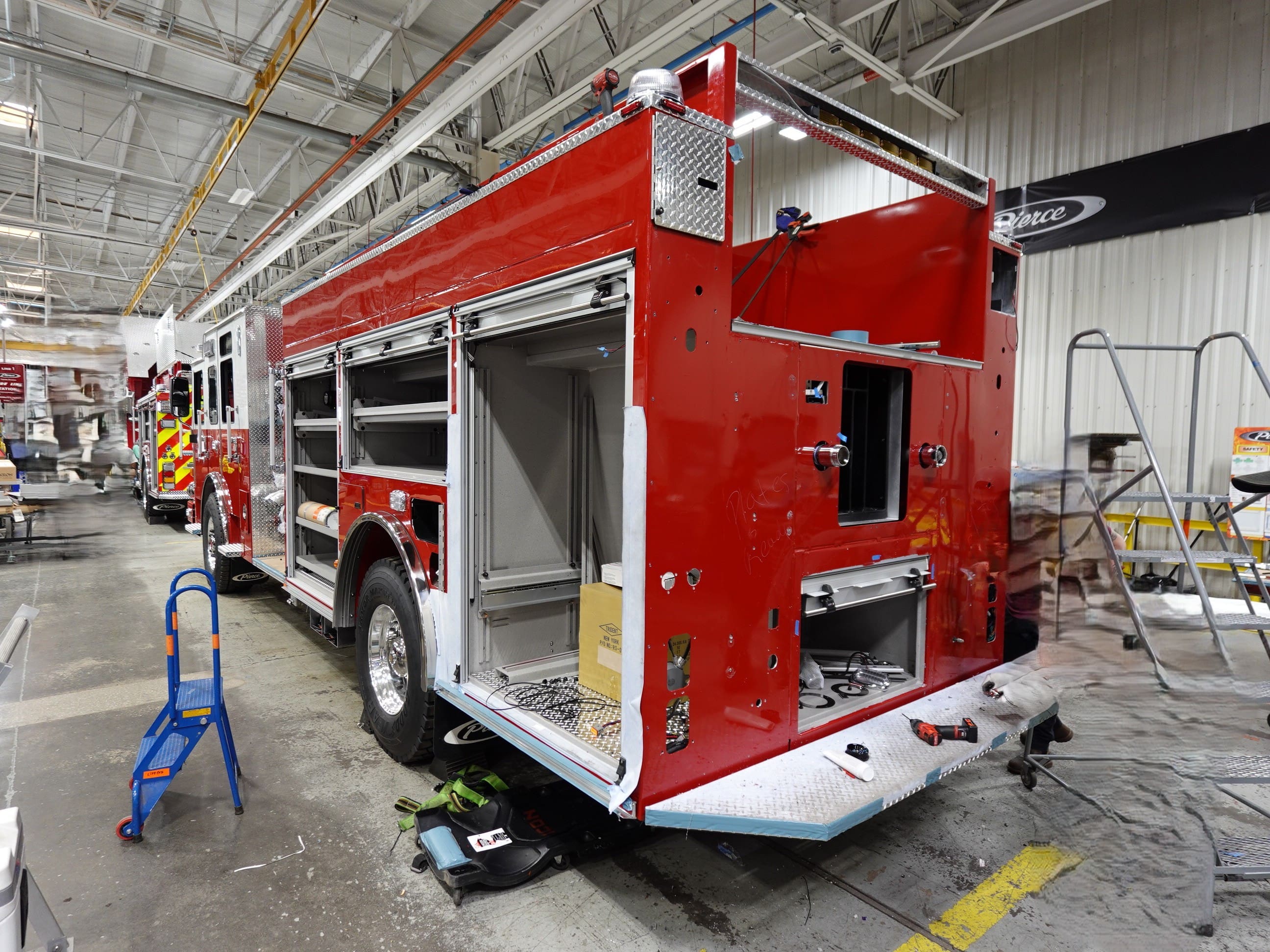

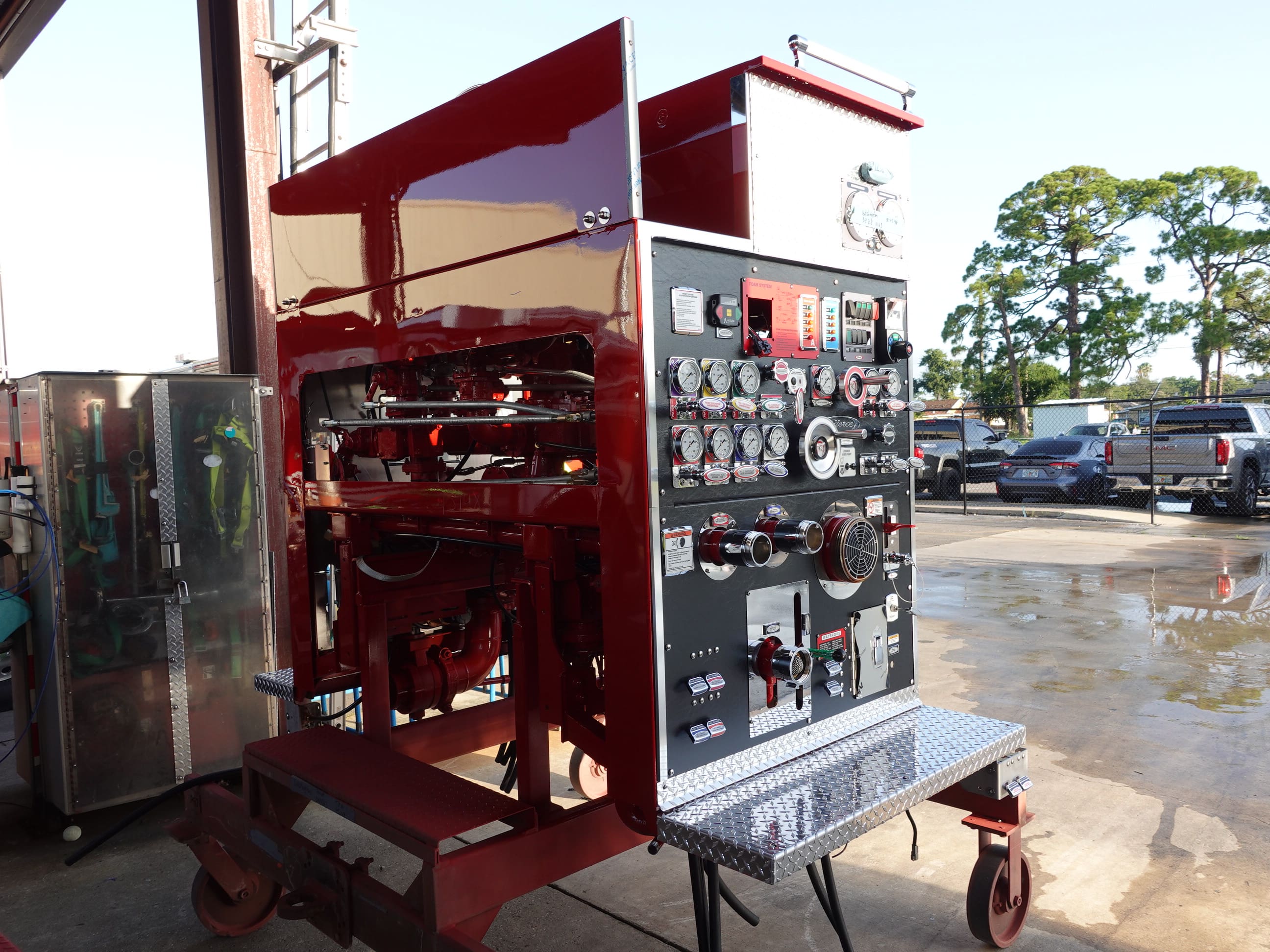

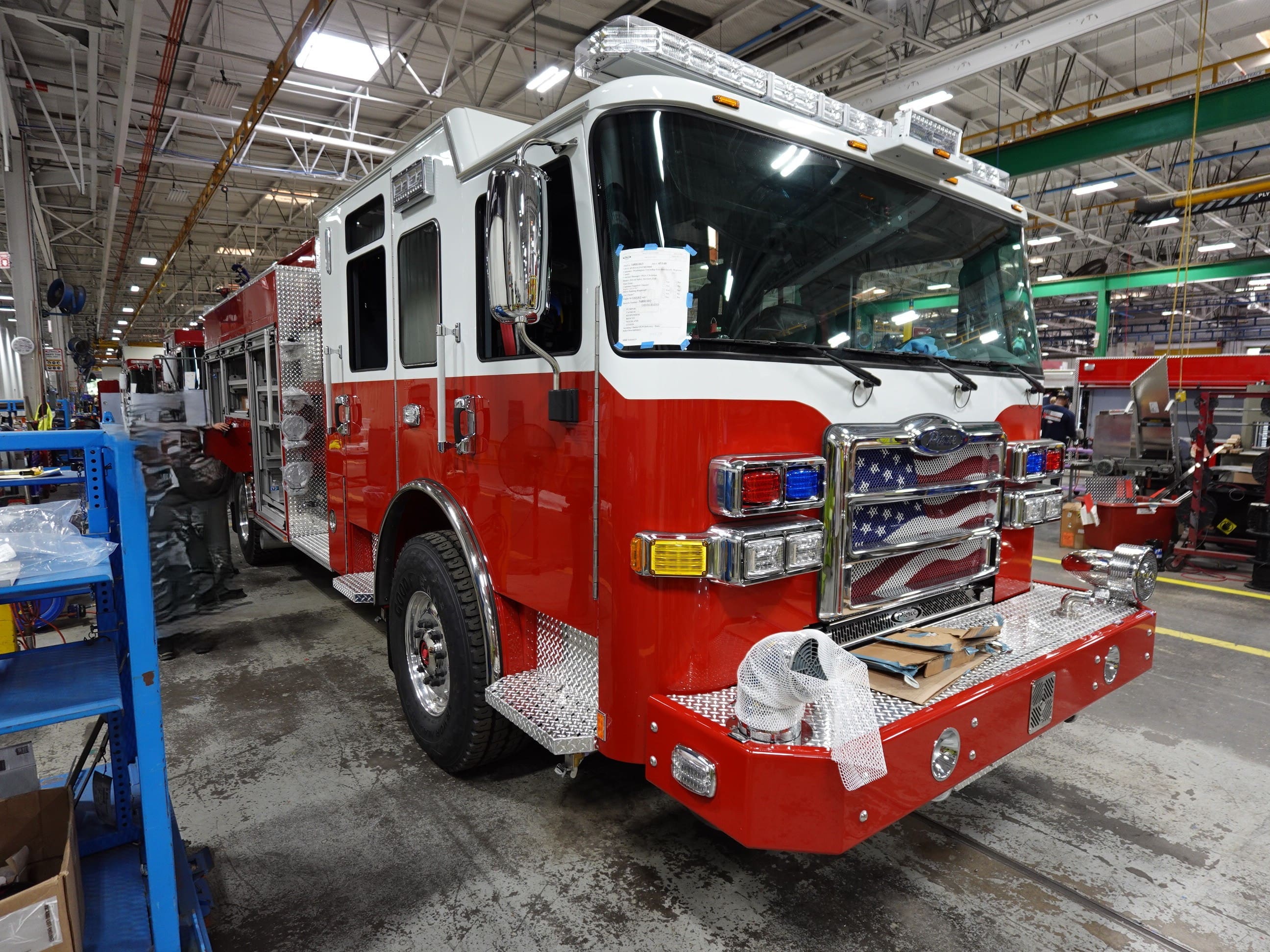

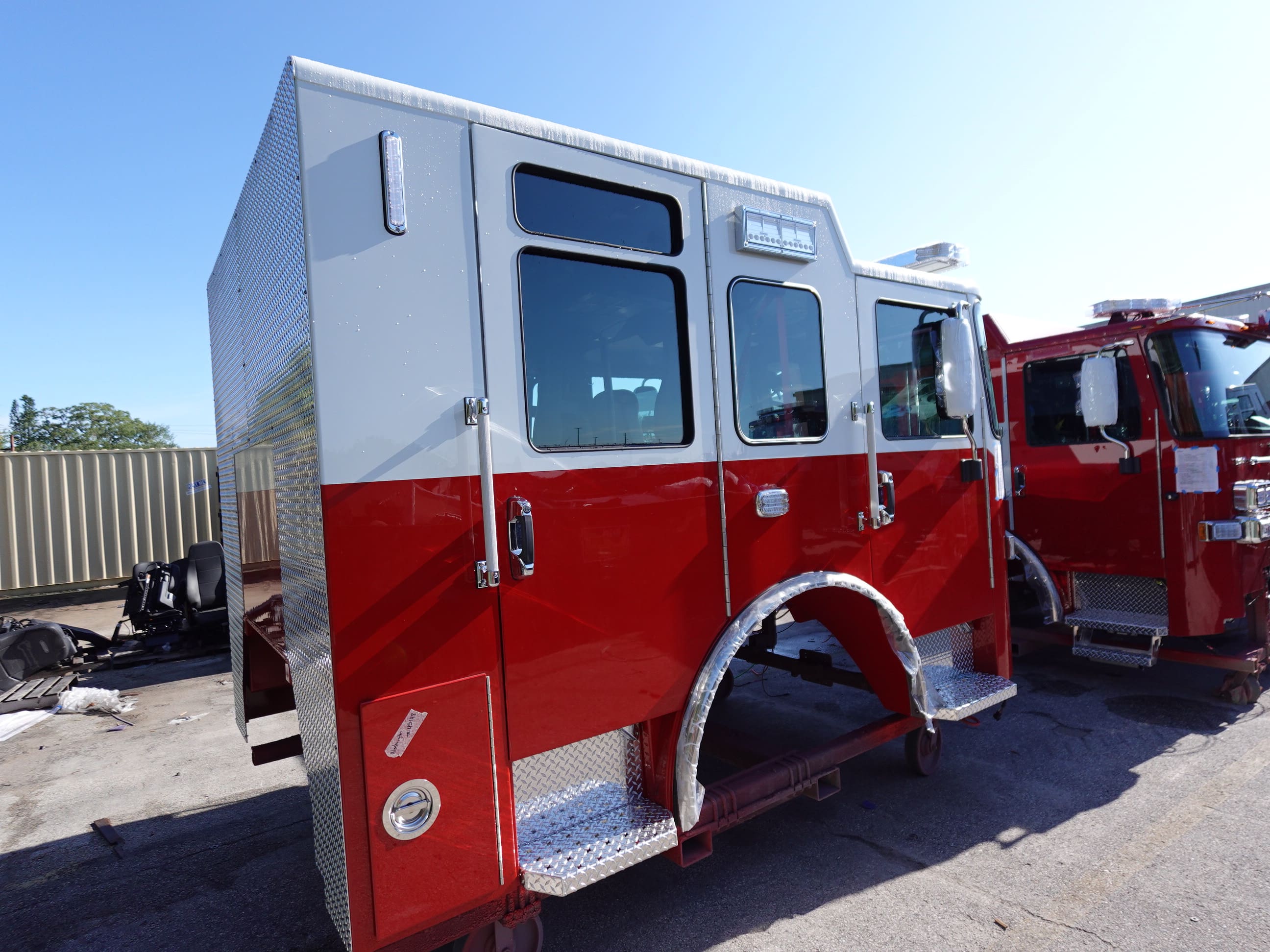

In this report, the apparatus was staged to complete test.

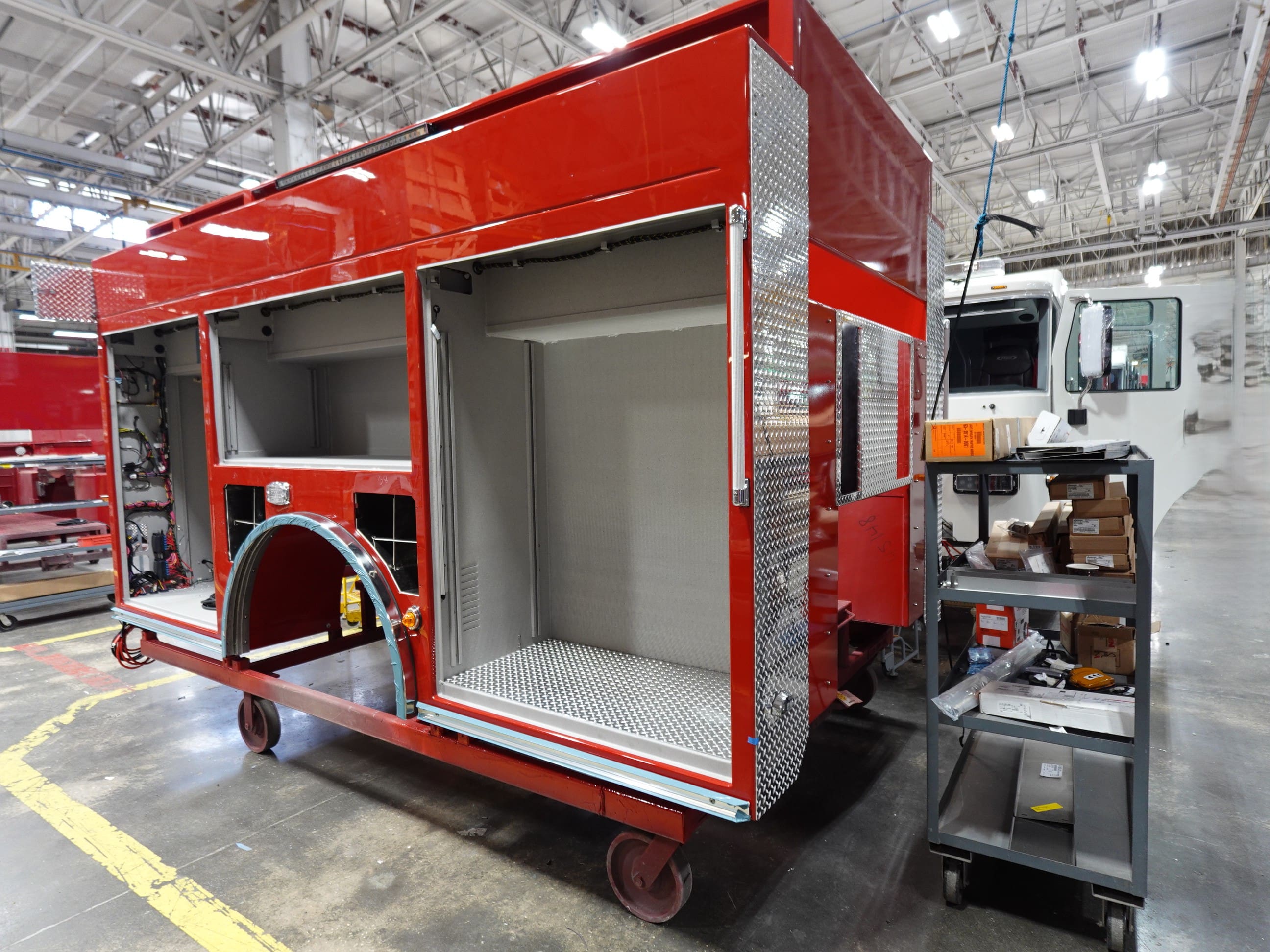

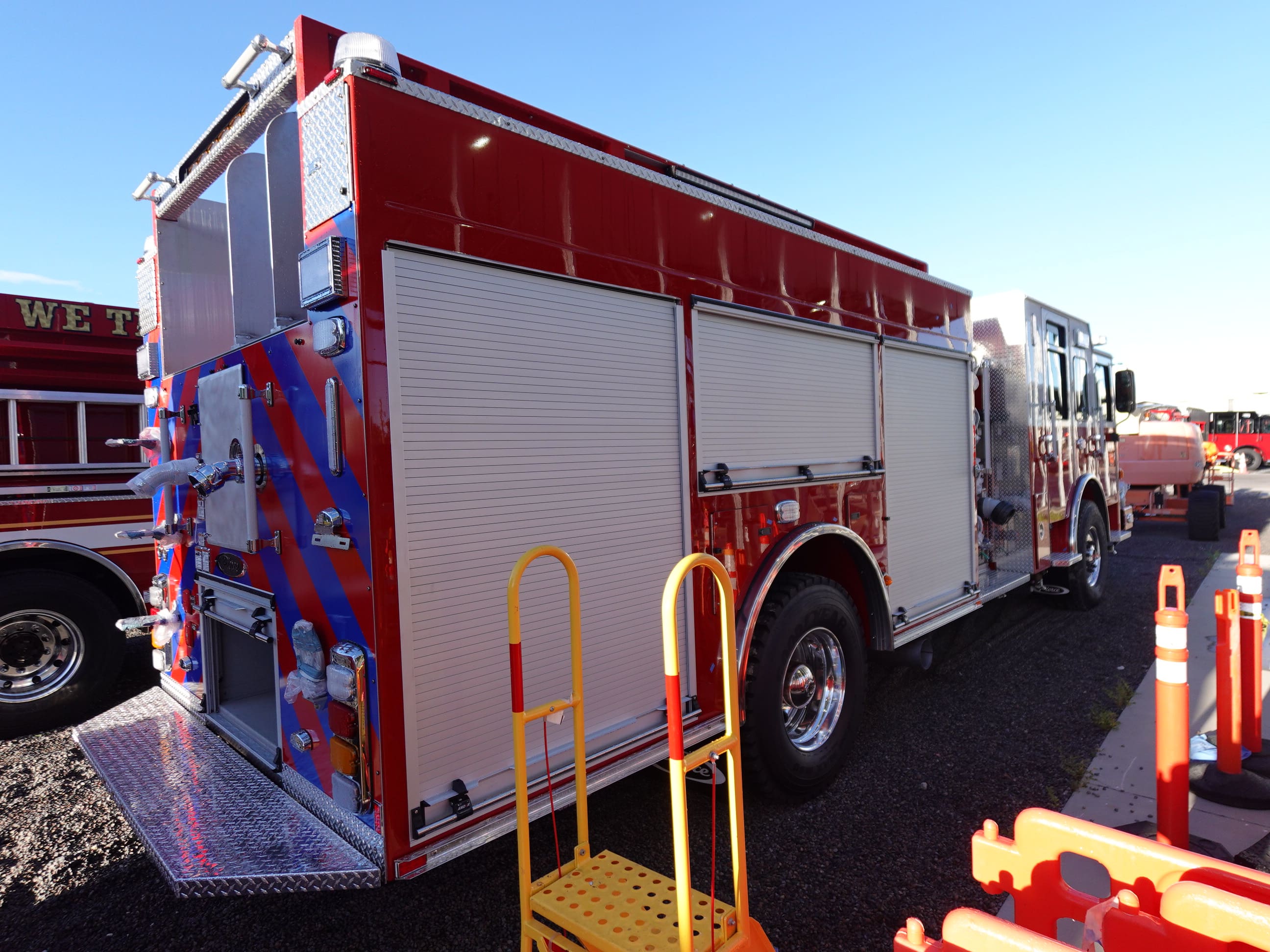

Once testing completes it will release to final product
evaluation where any remaining content will be applied.
When finished it will be made ready for the customer
acceptance inspection. This is the last scheduled report.
09-18-26

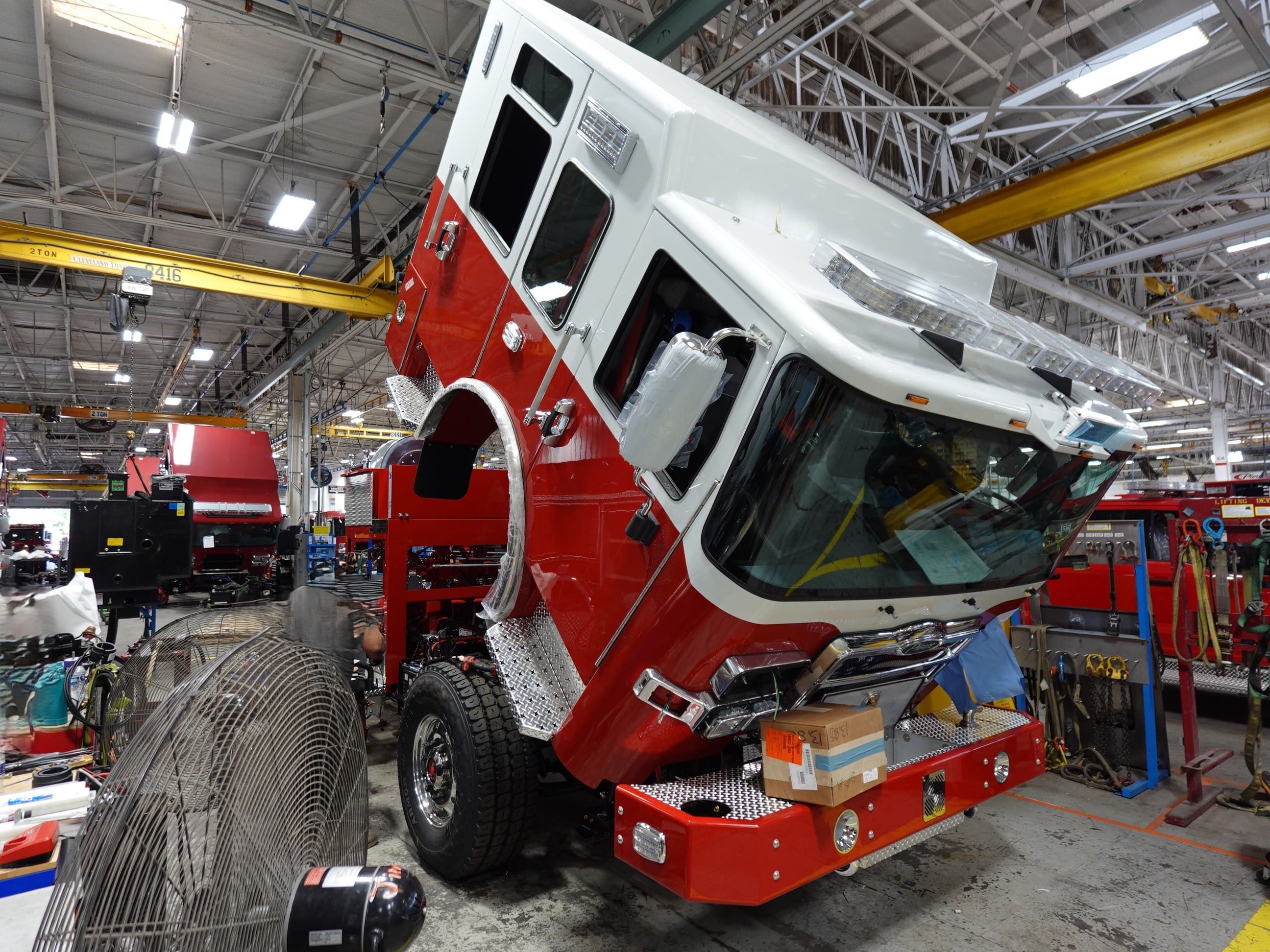

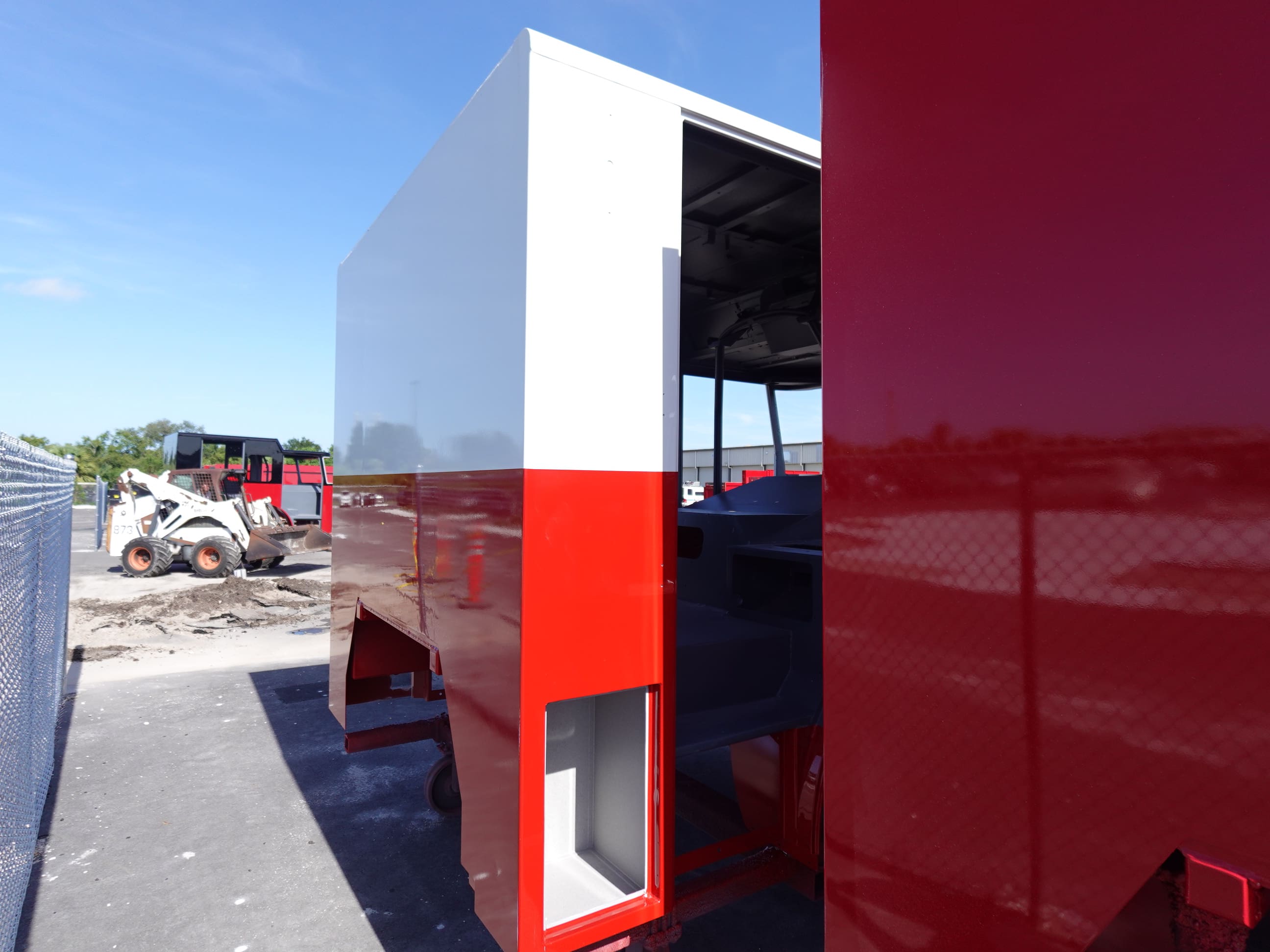

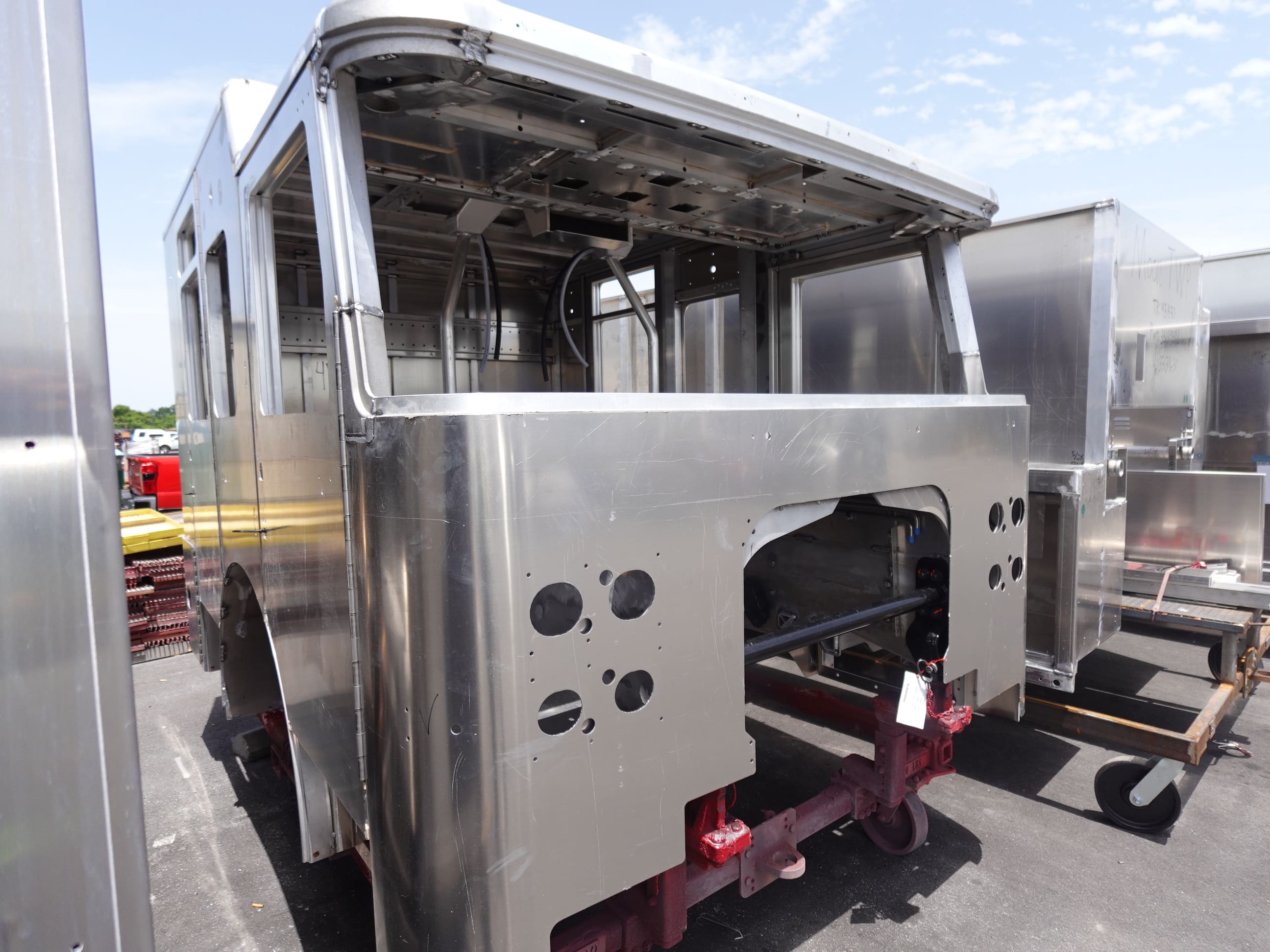

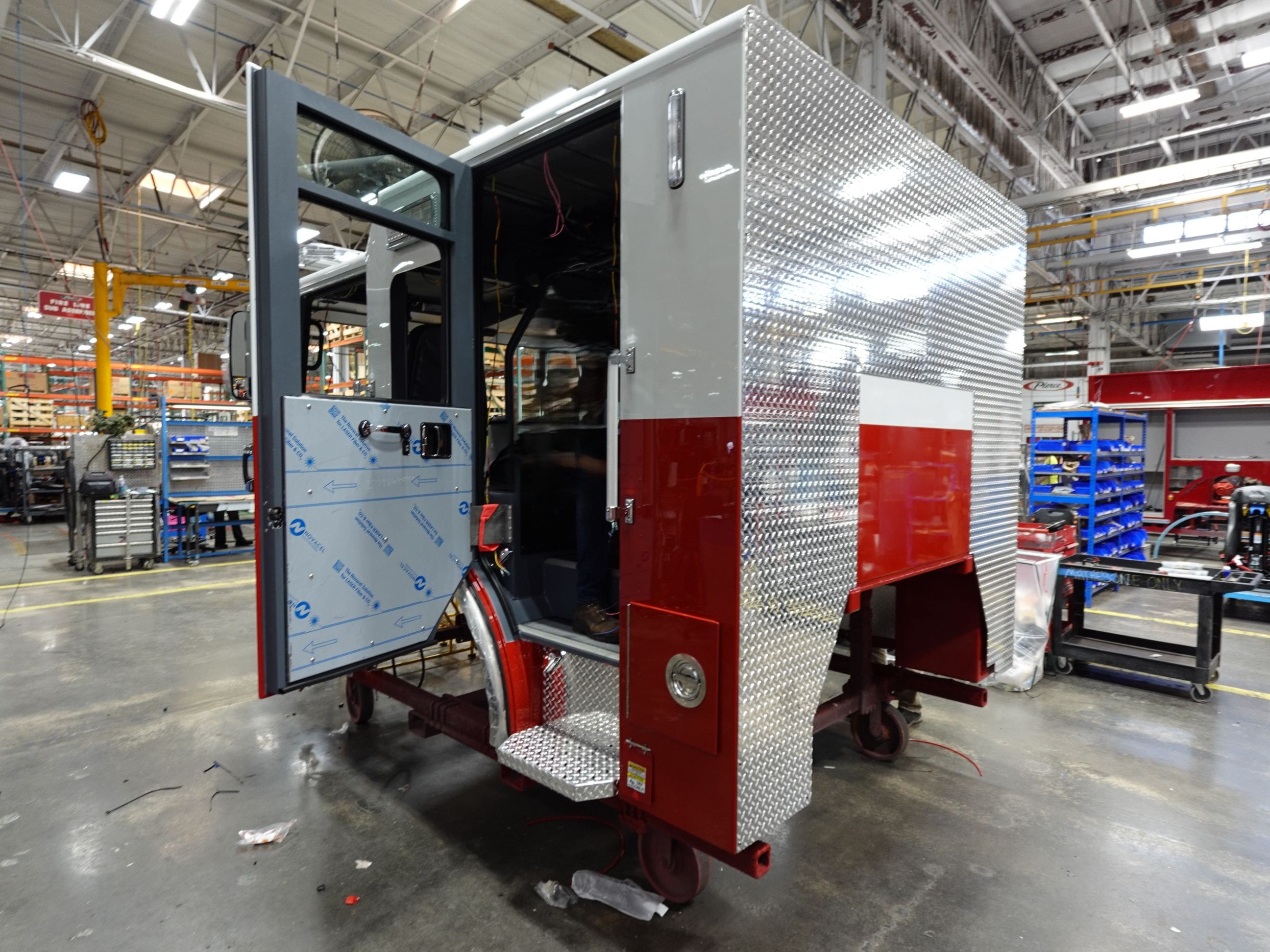

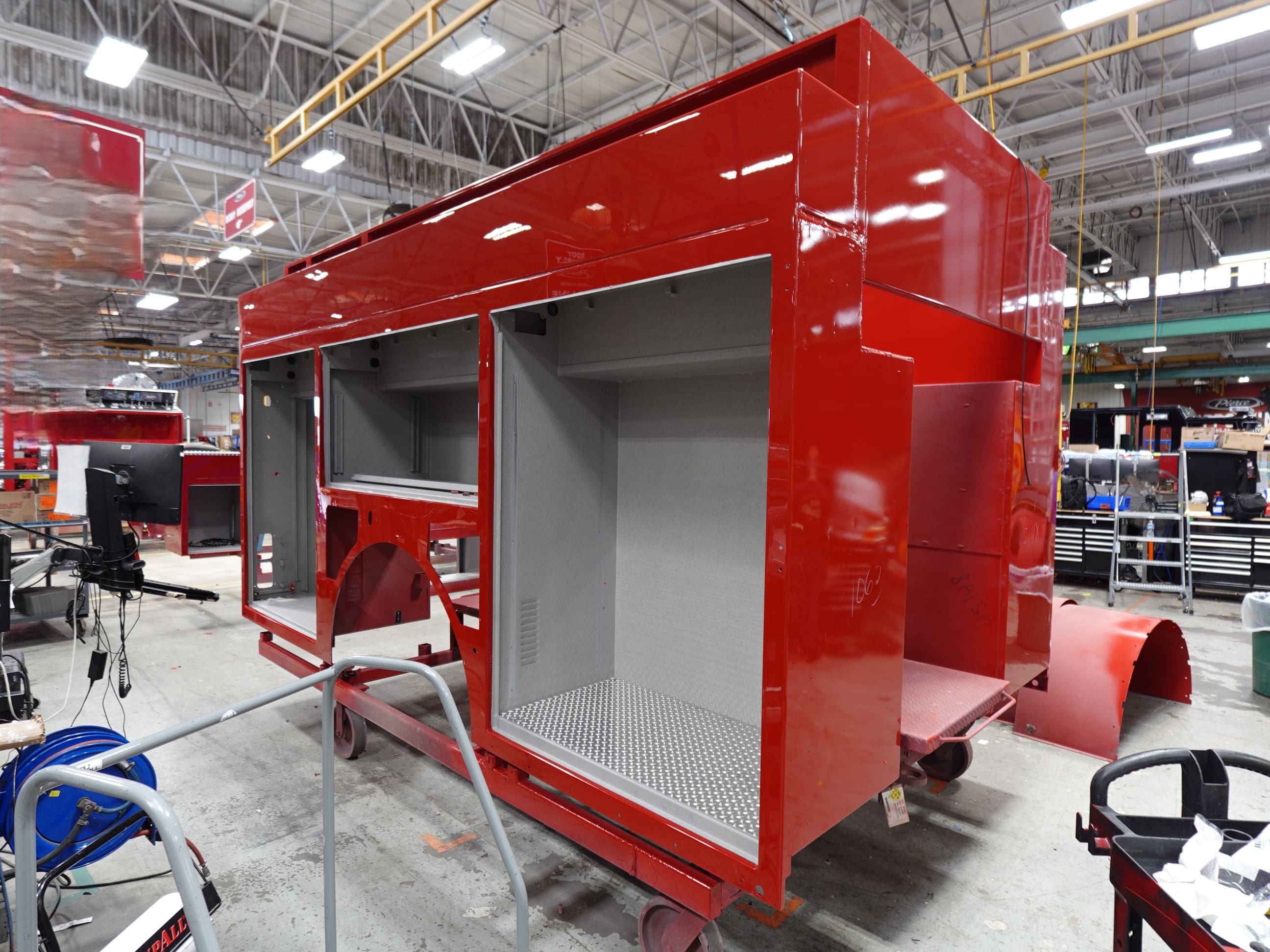

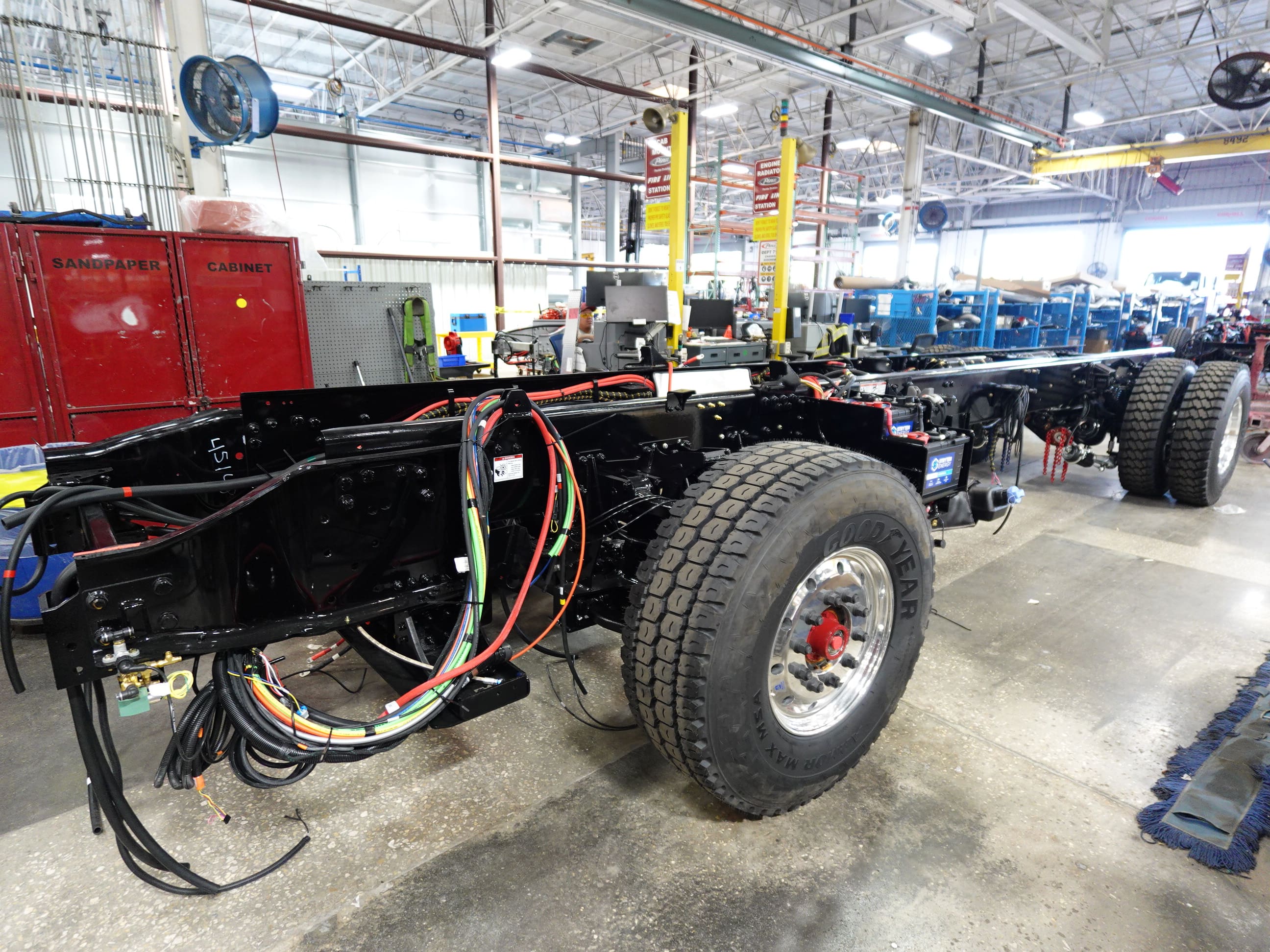

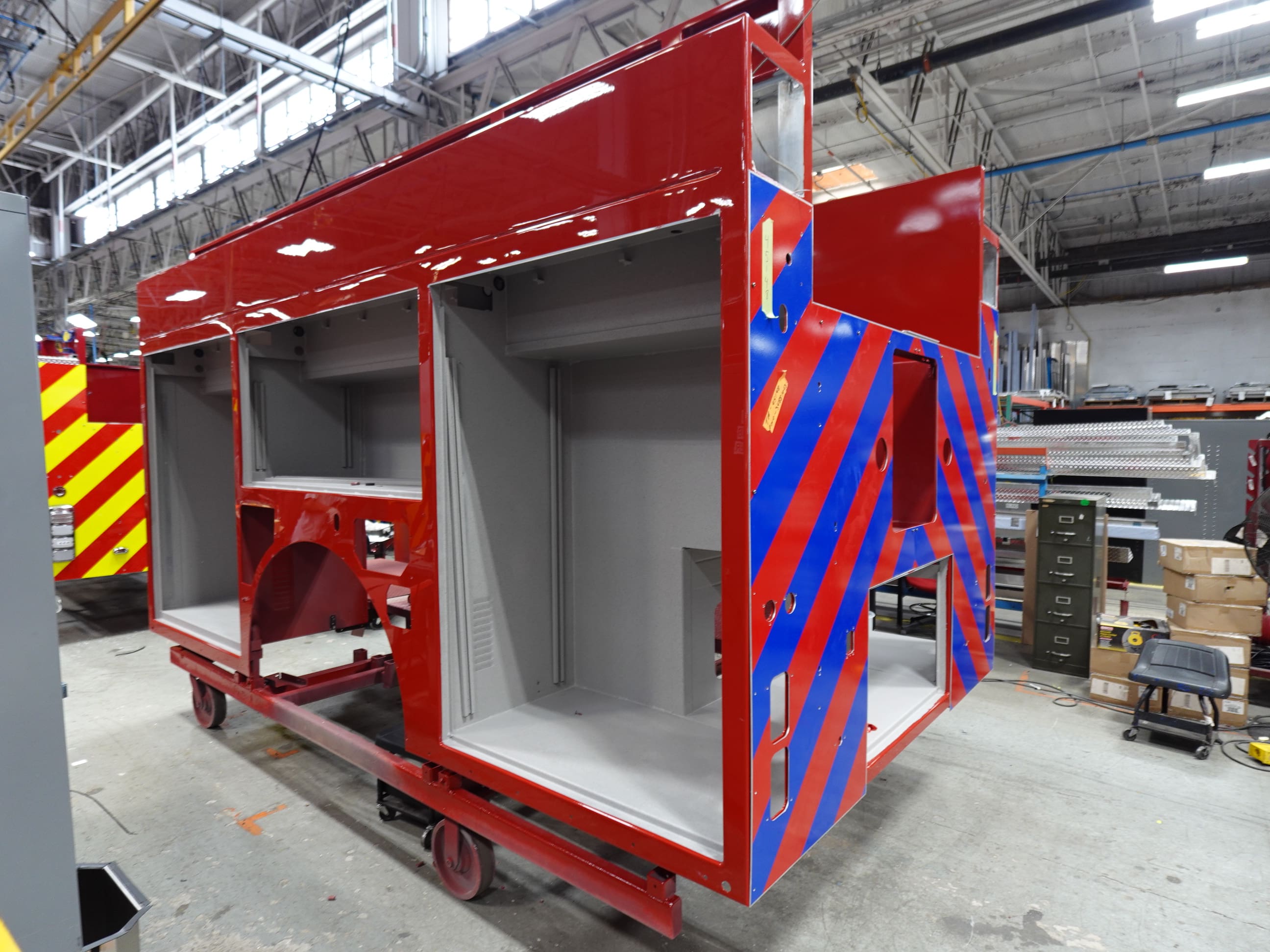

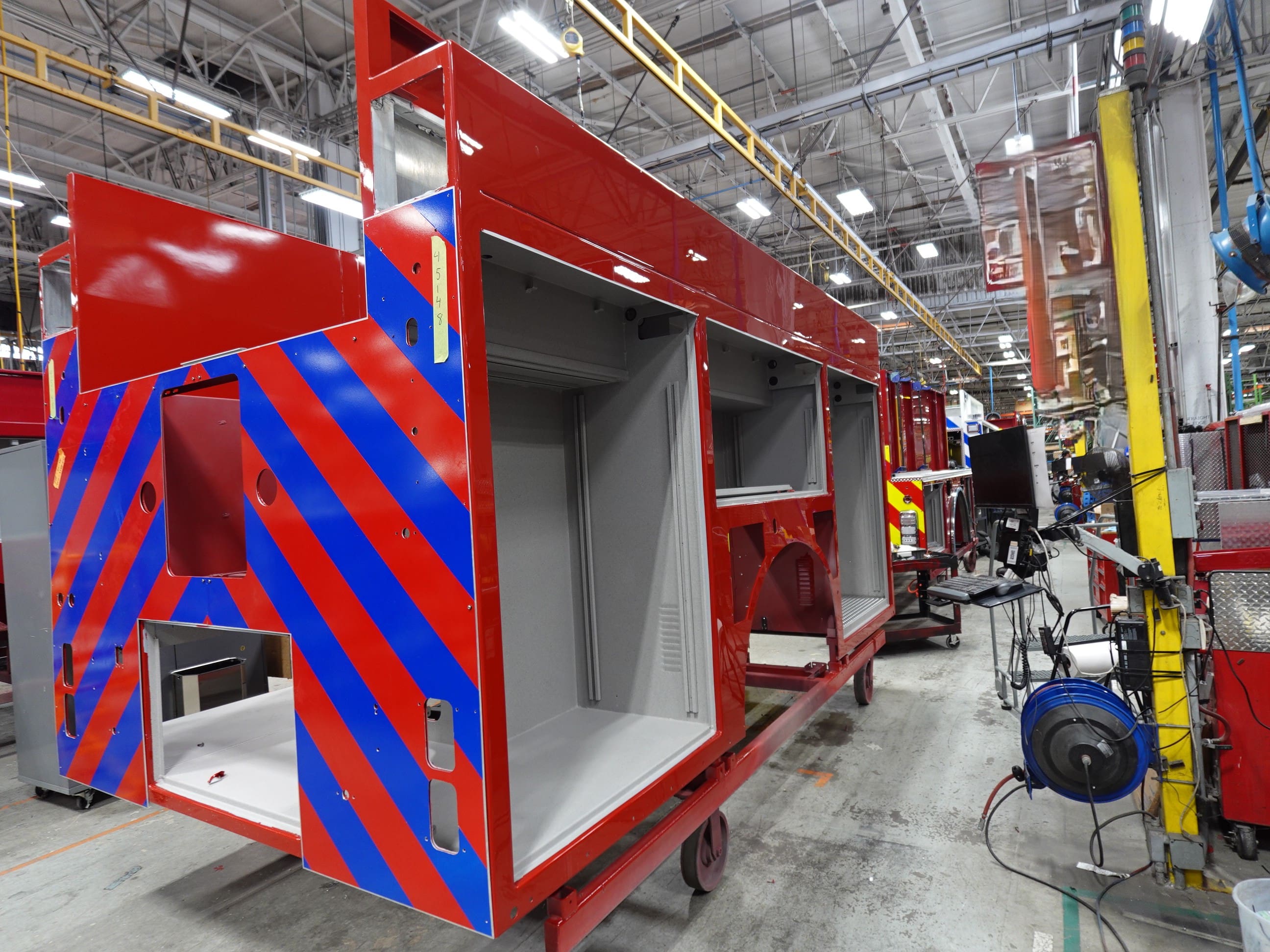

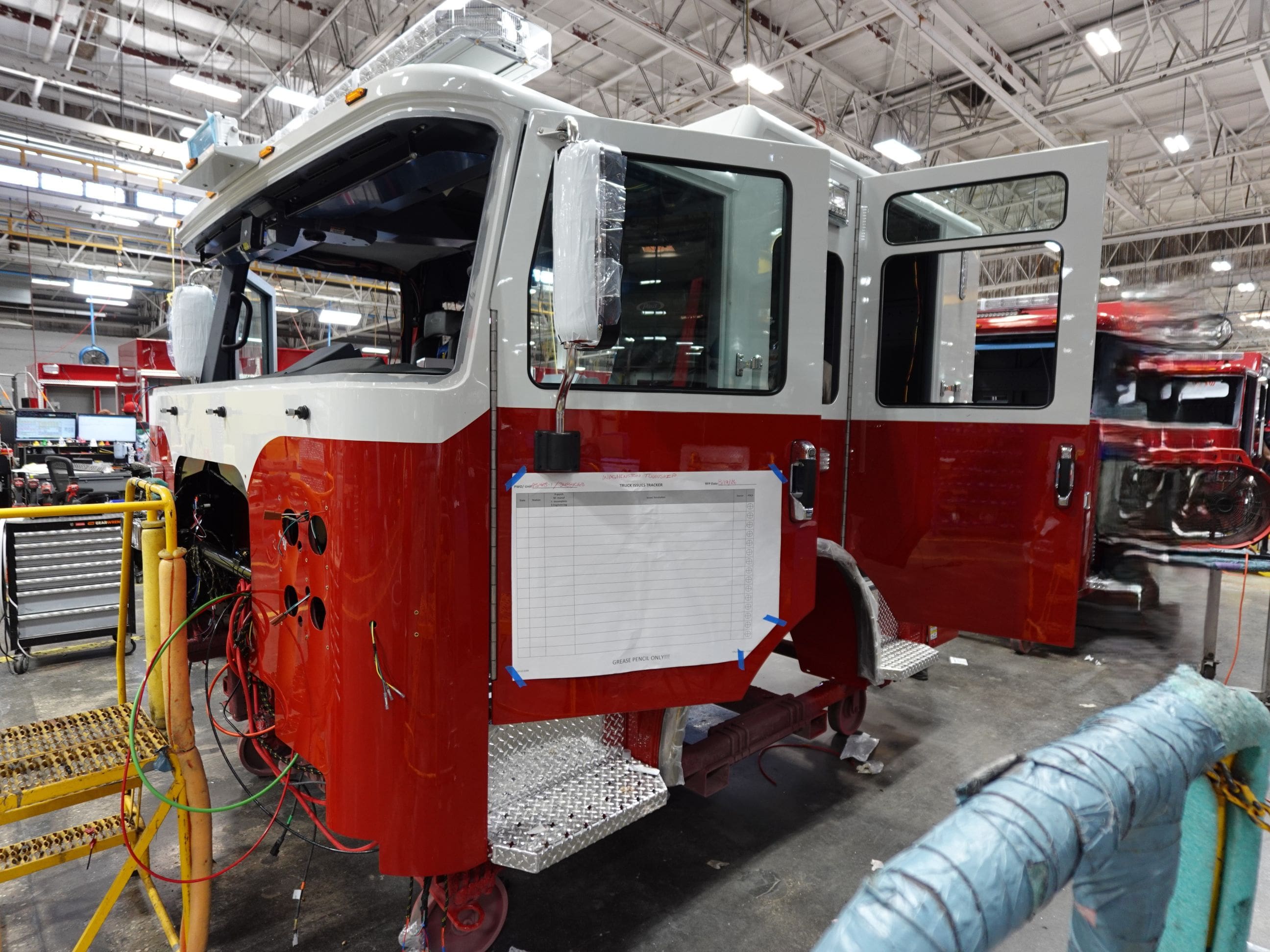

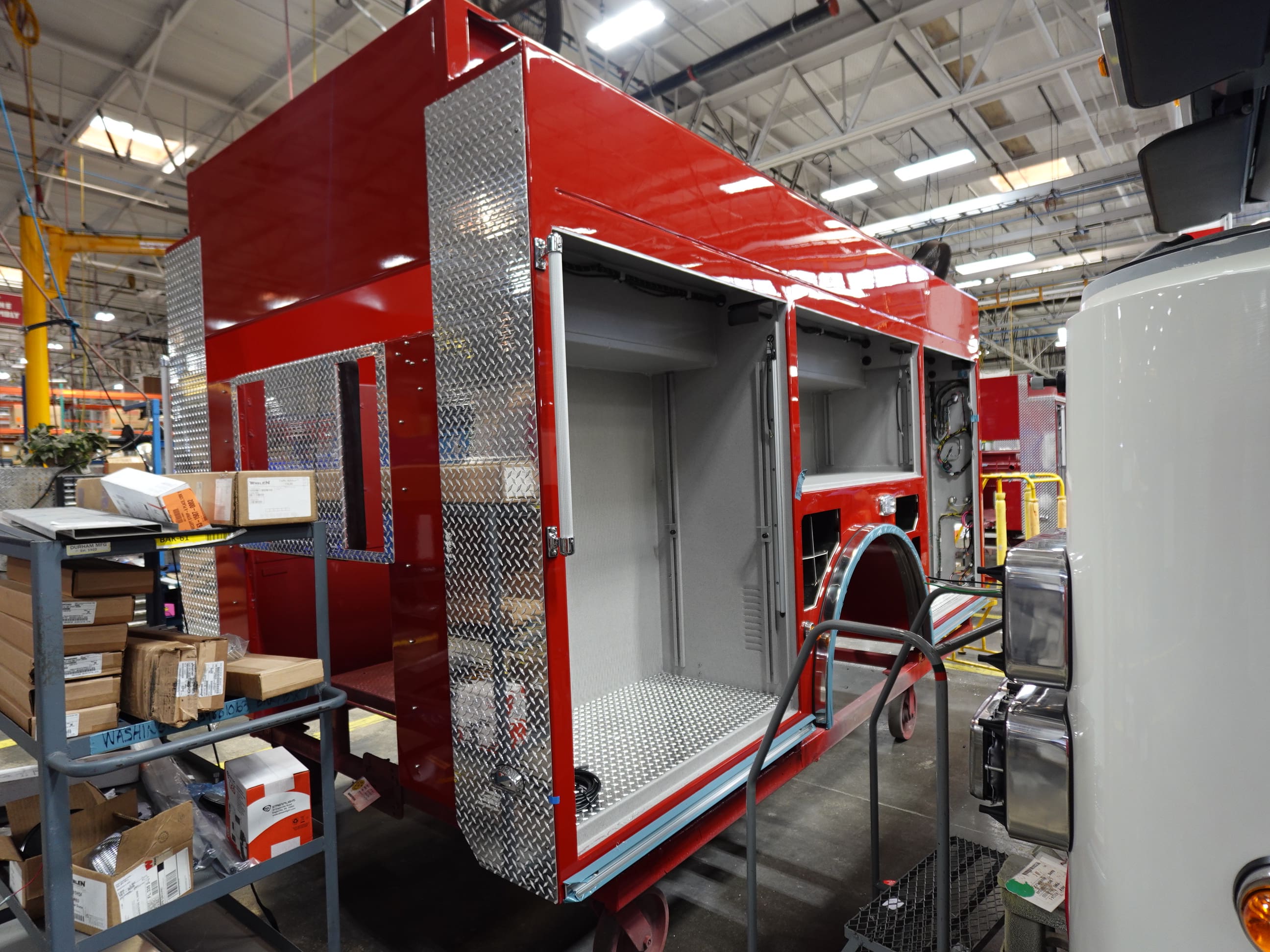

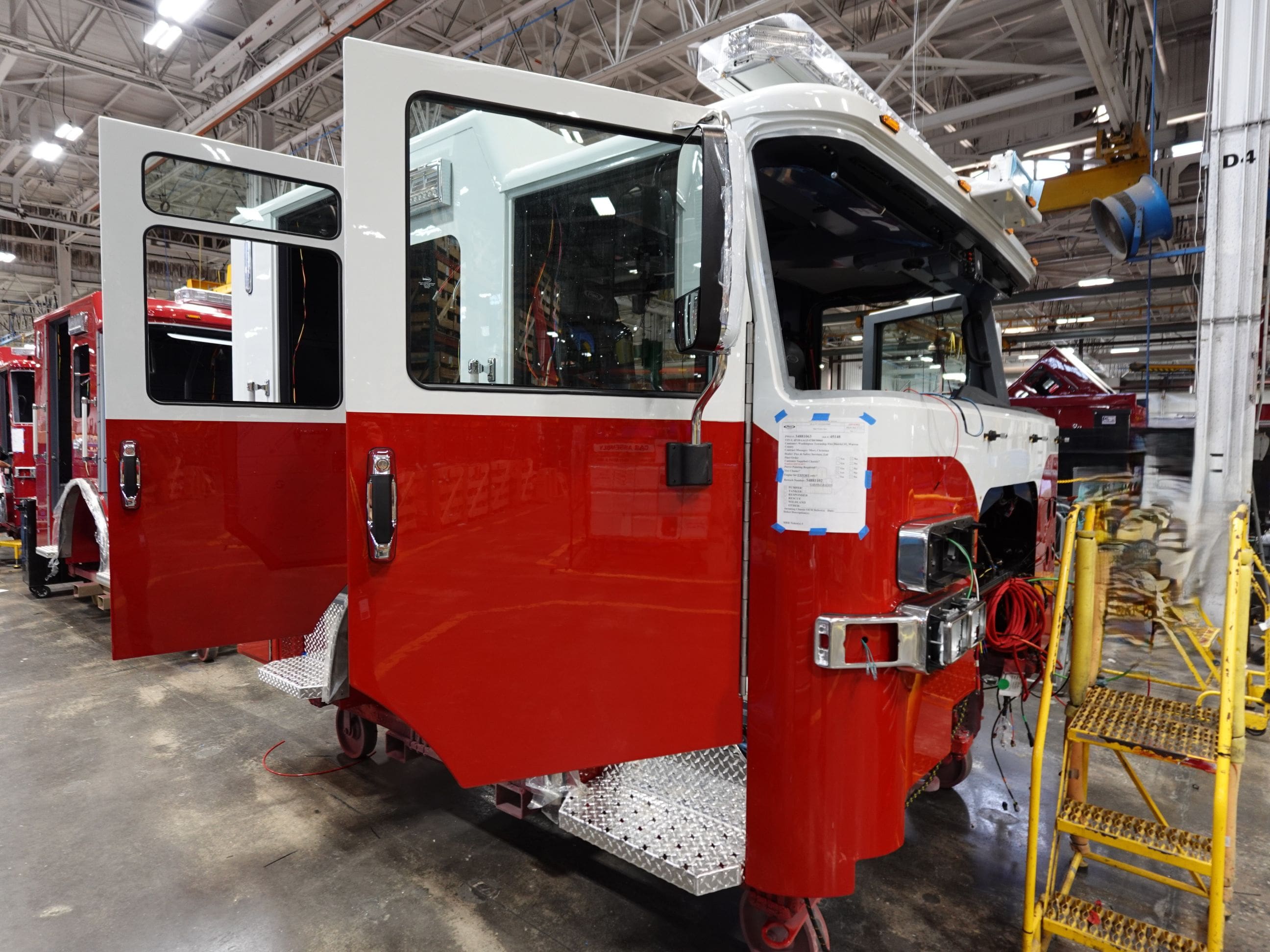

In this report, the body was merged with the chassis followed by the start of final assembly.

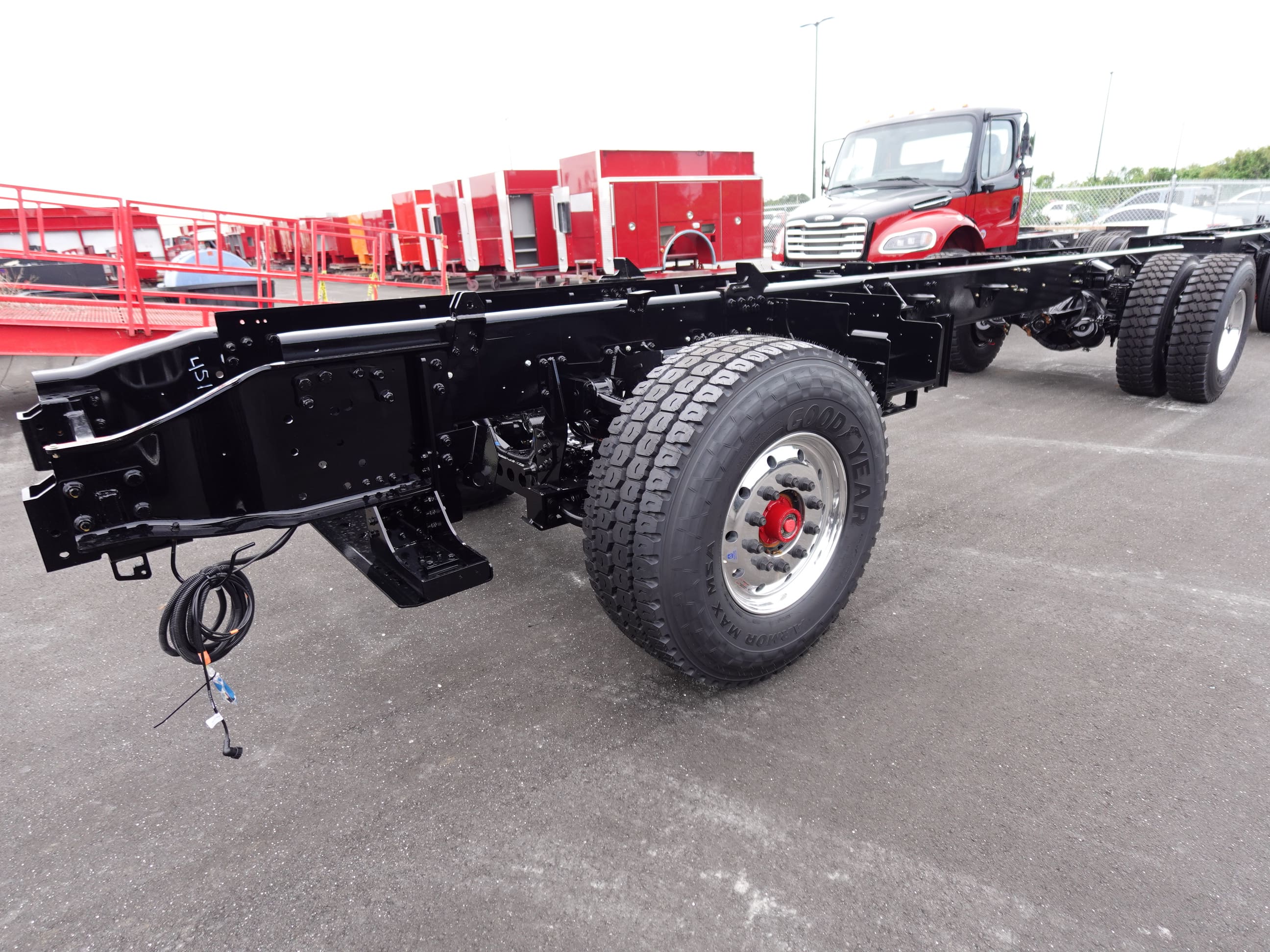

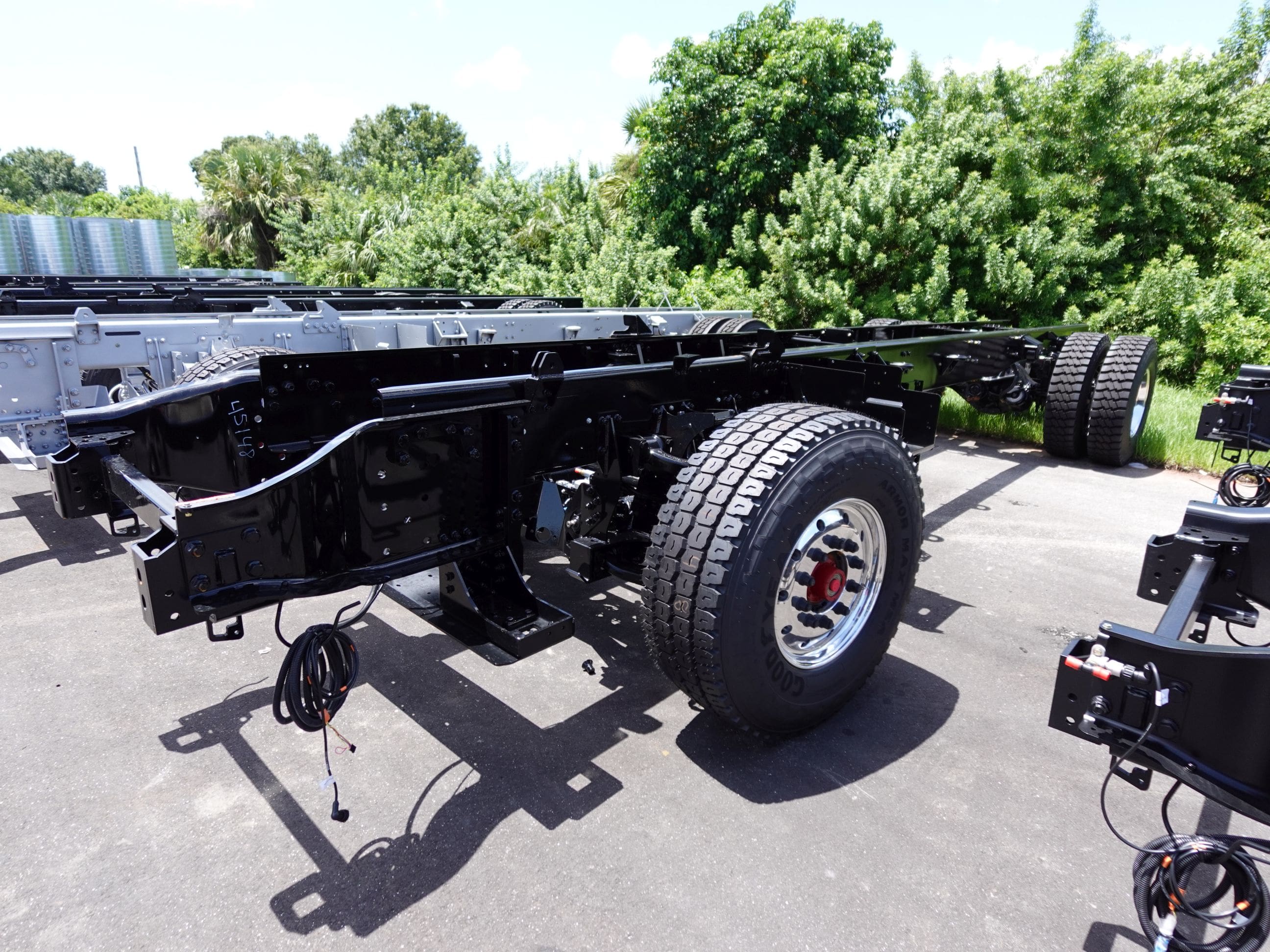

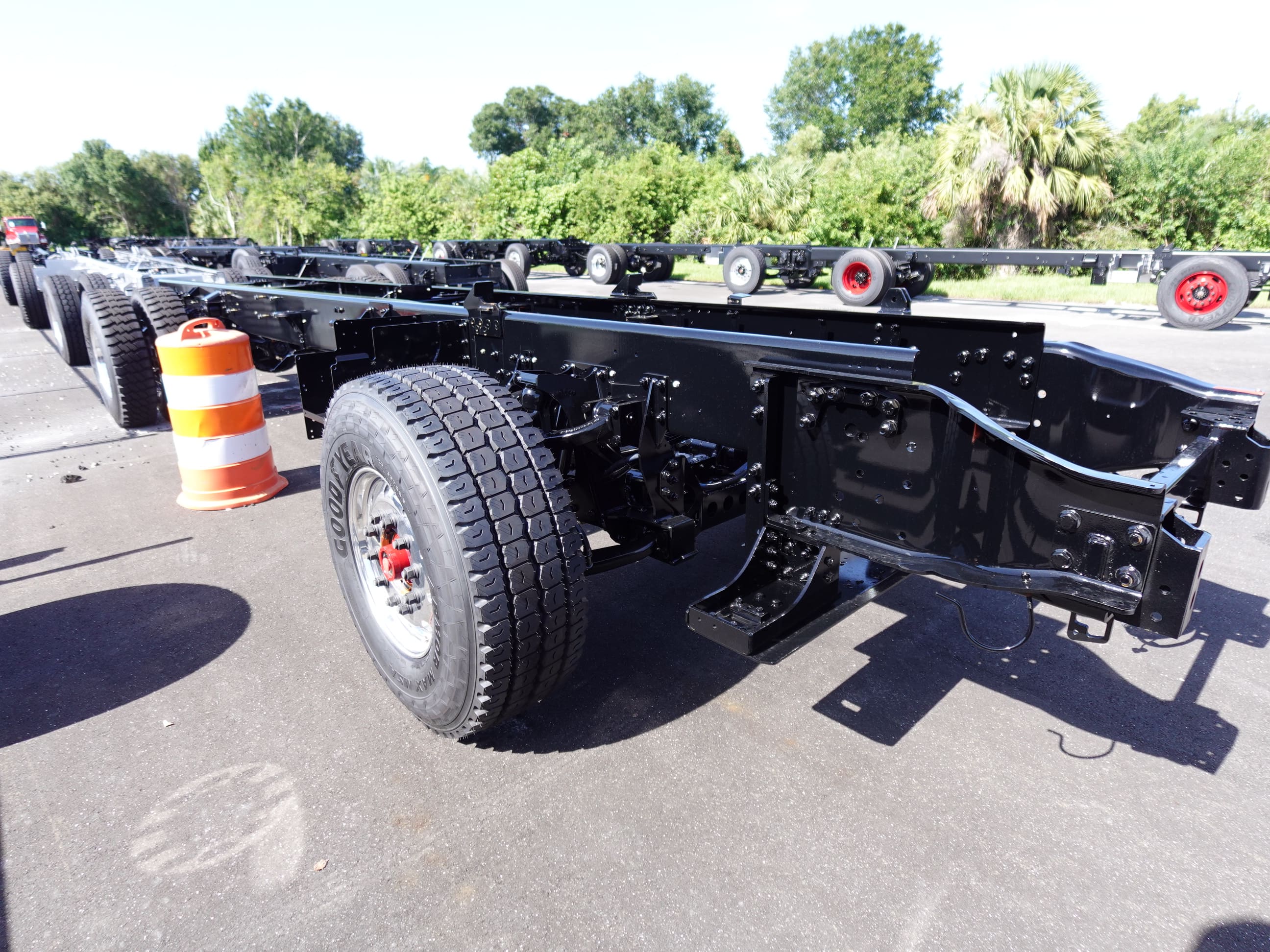

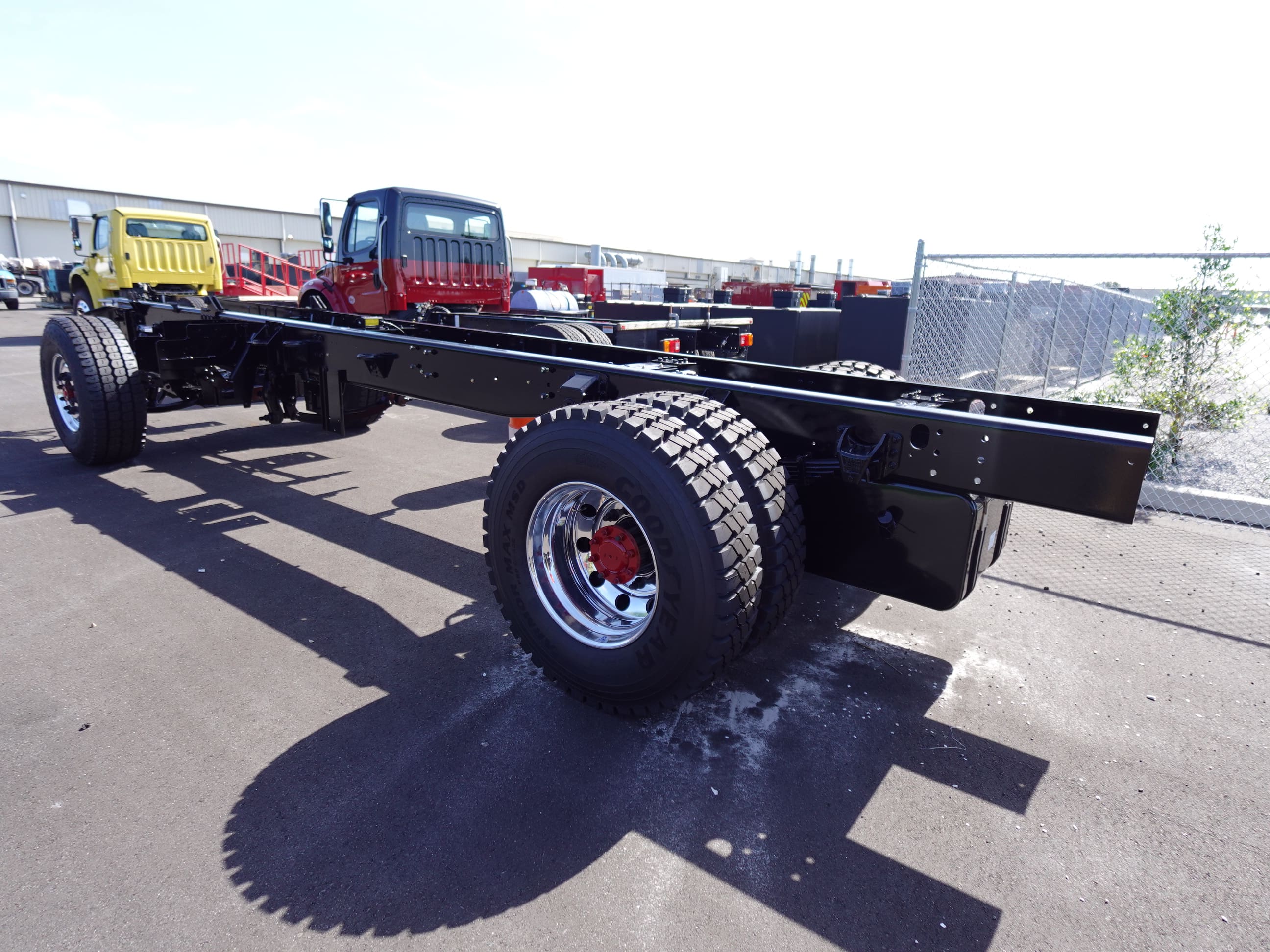

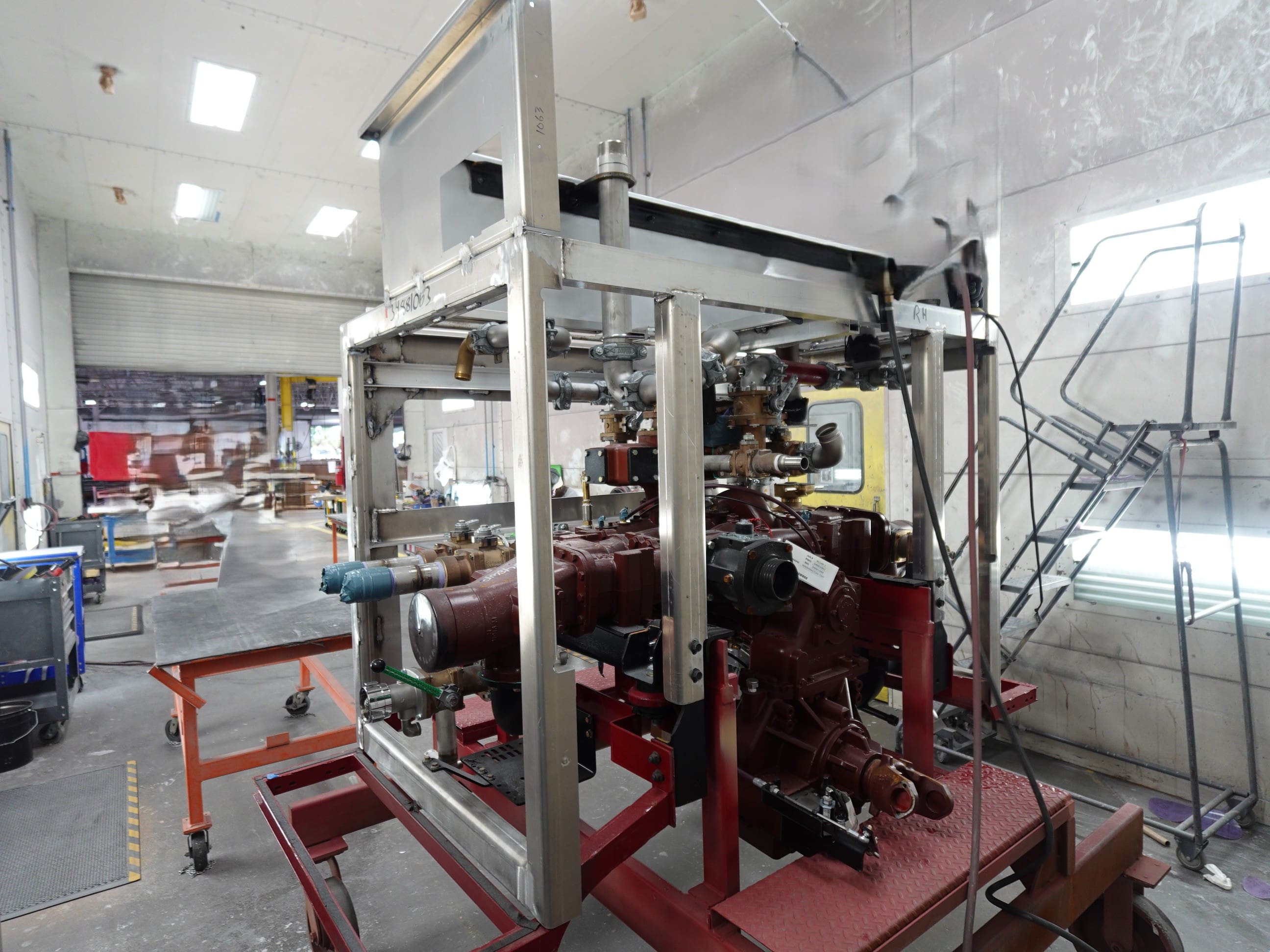

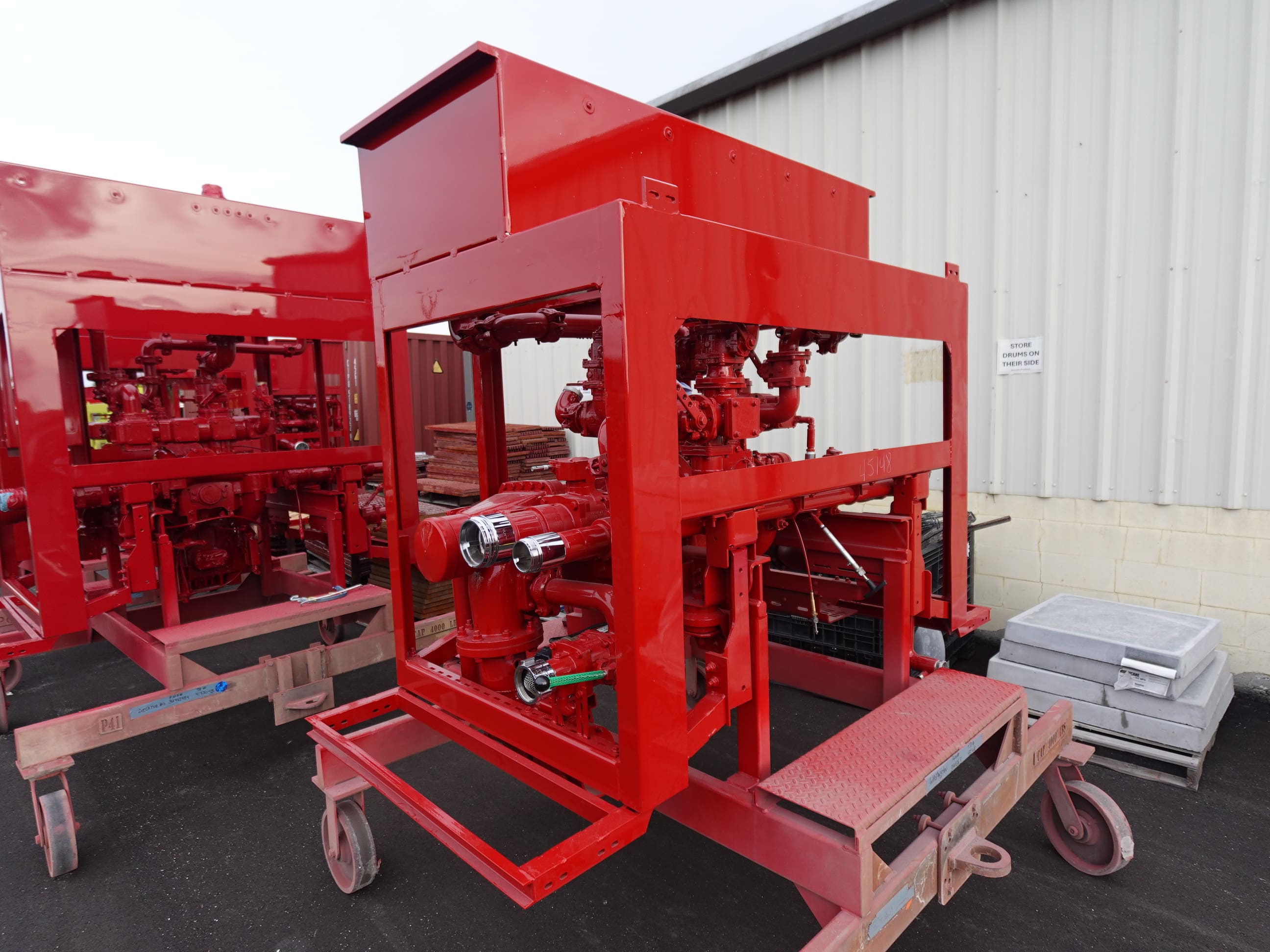

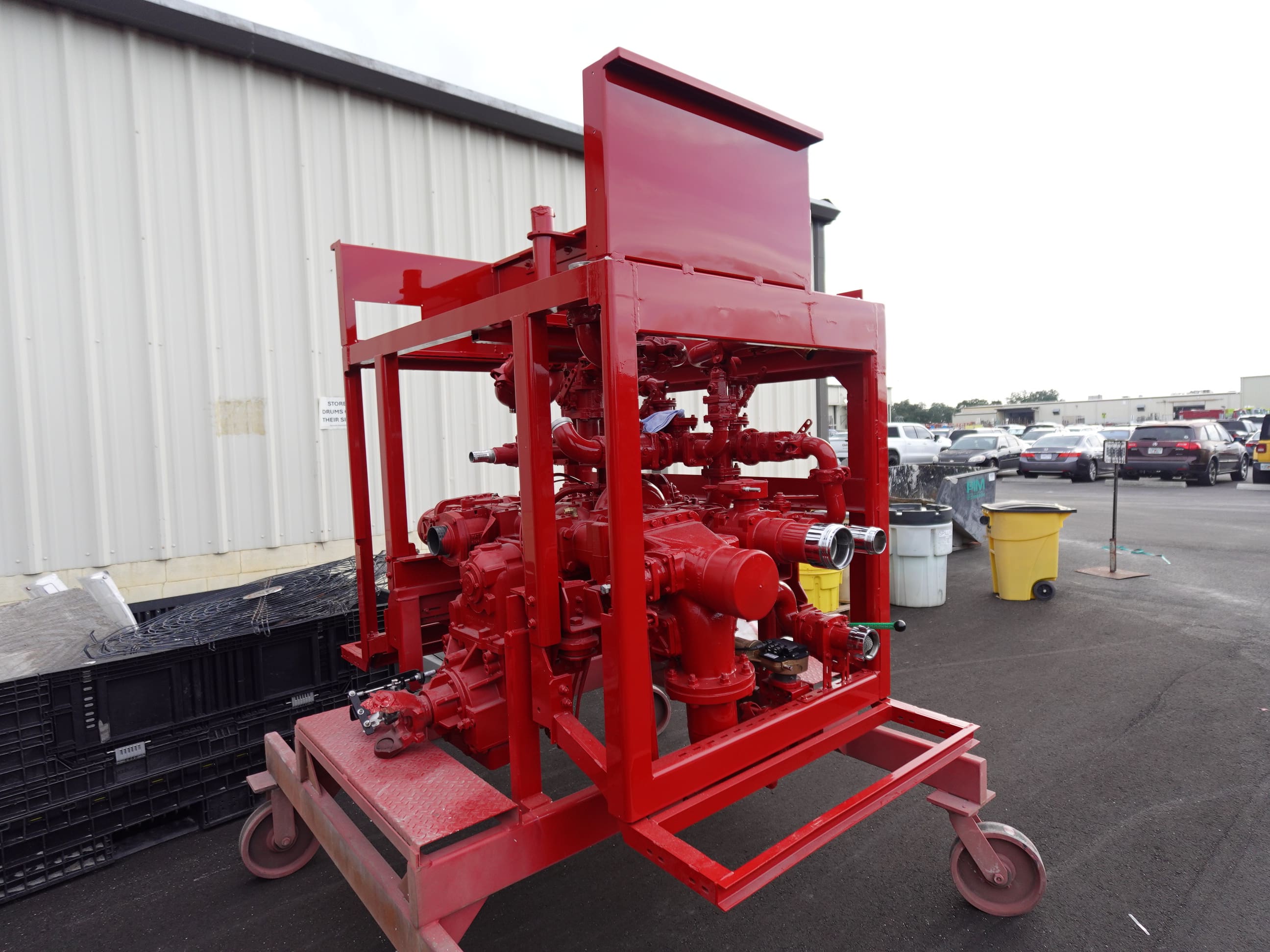

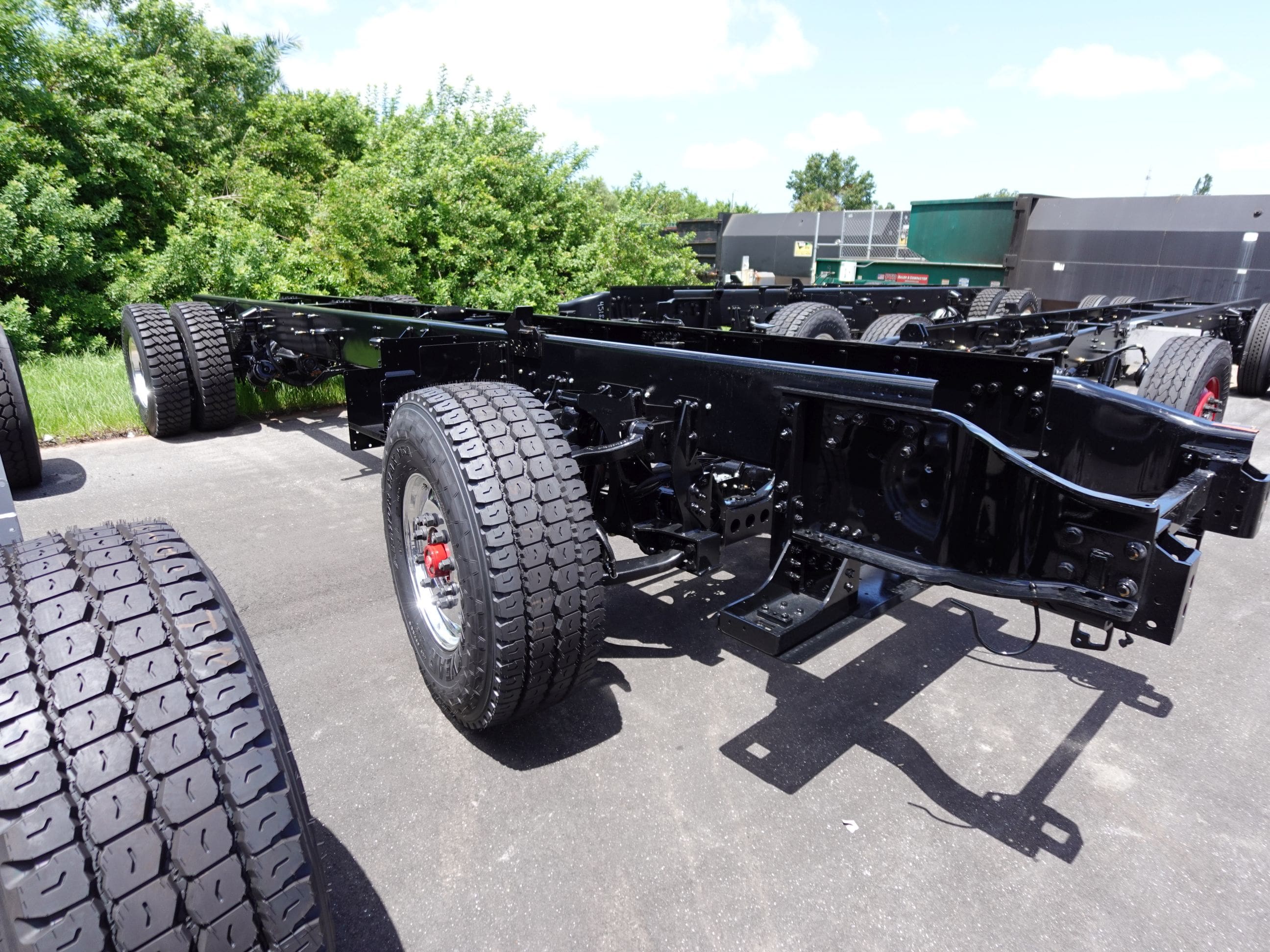

09-04-26

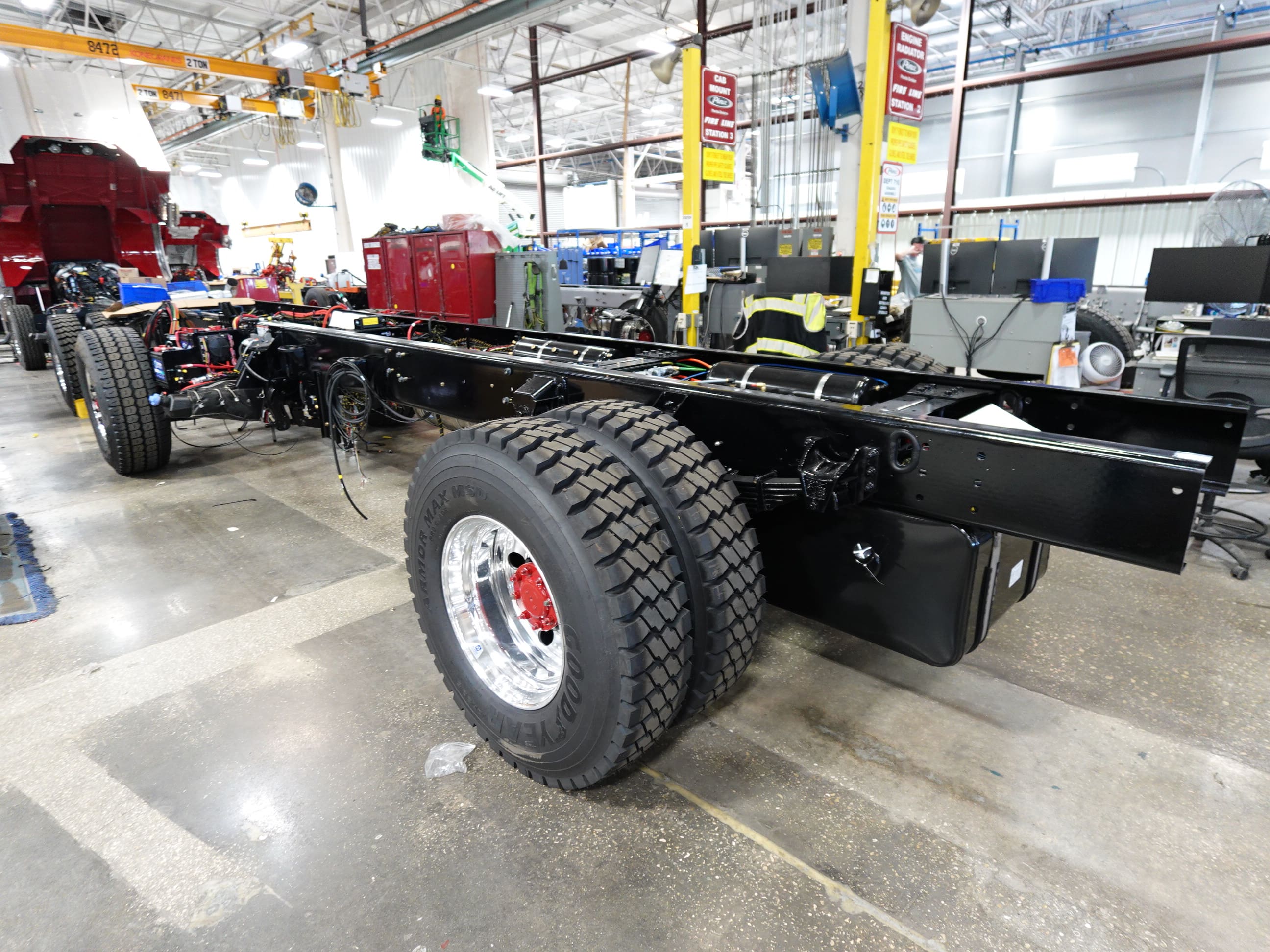

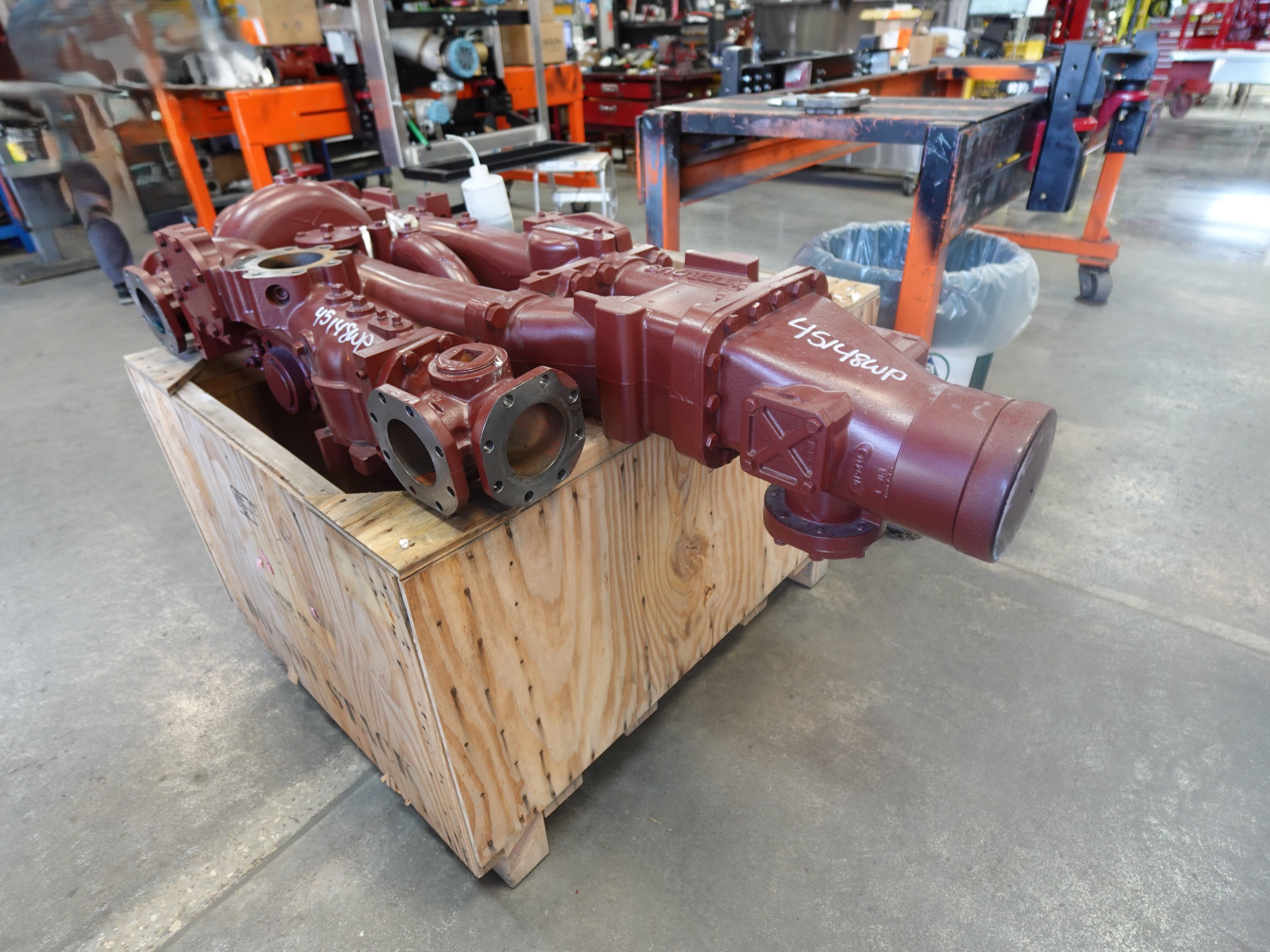

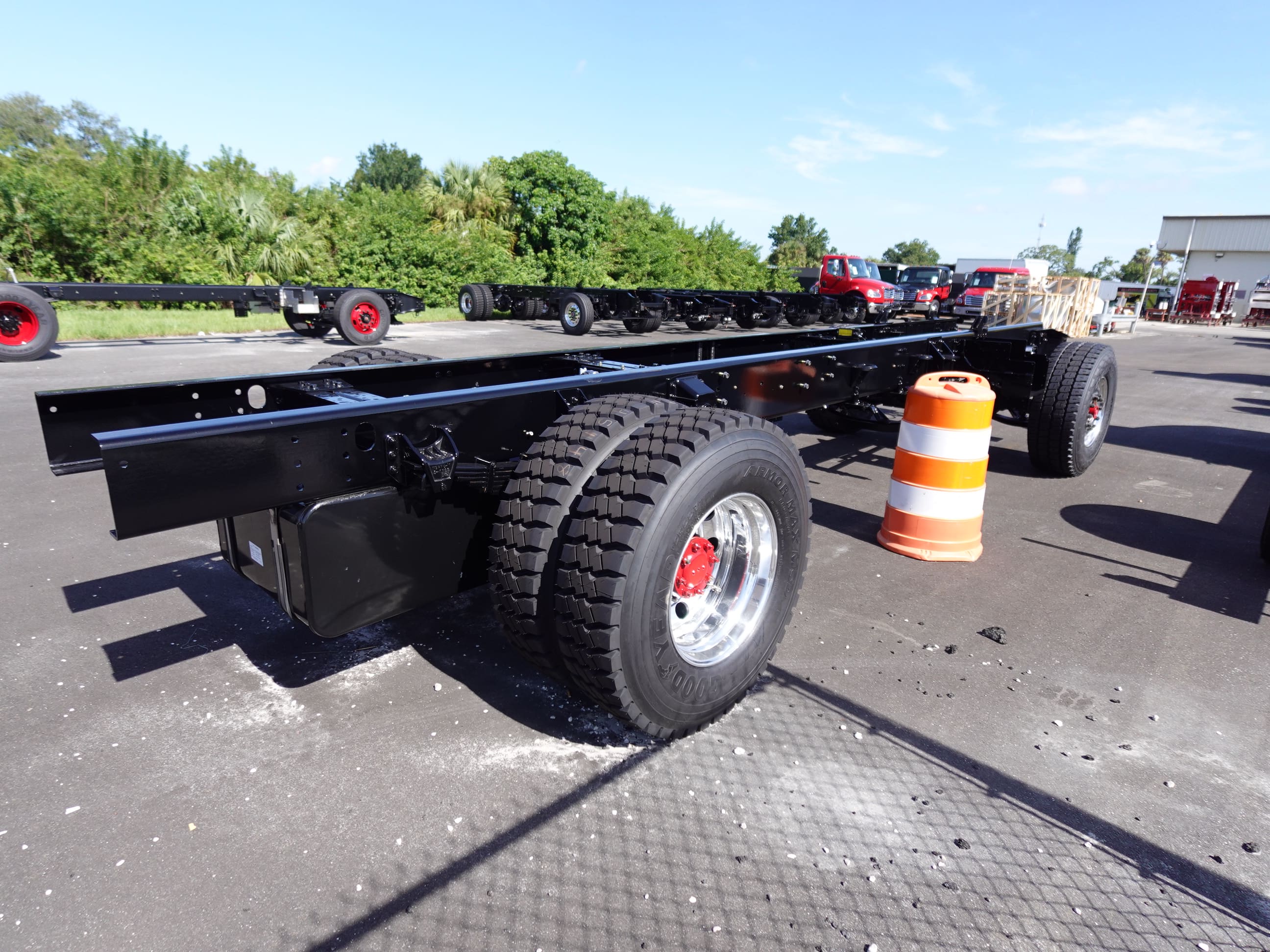

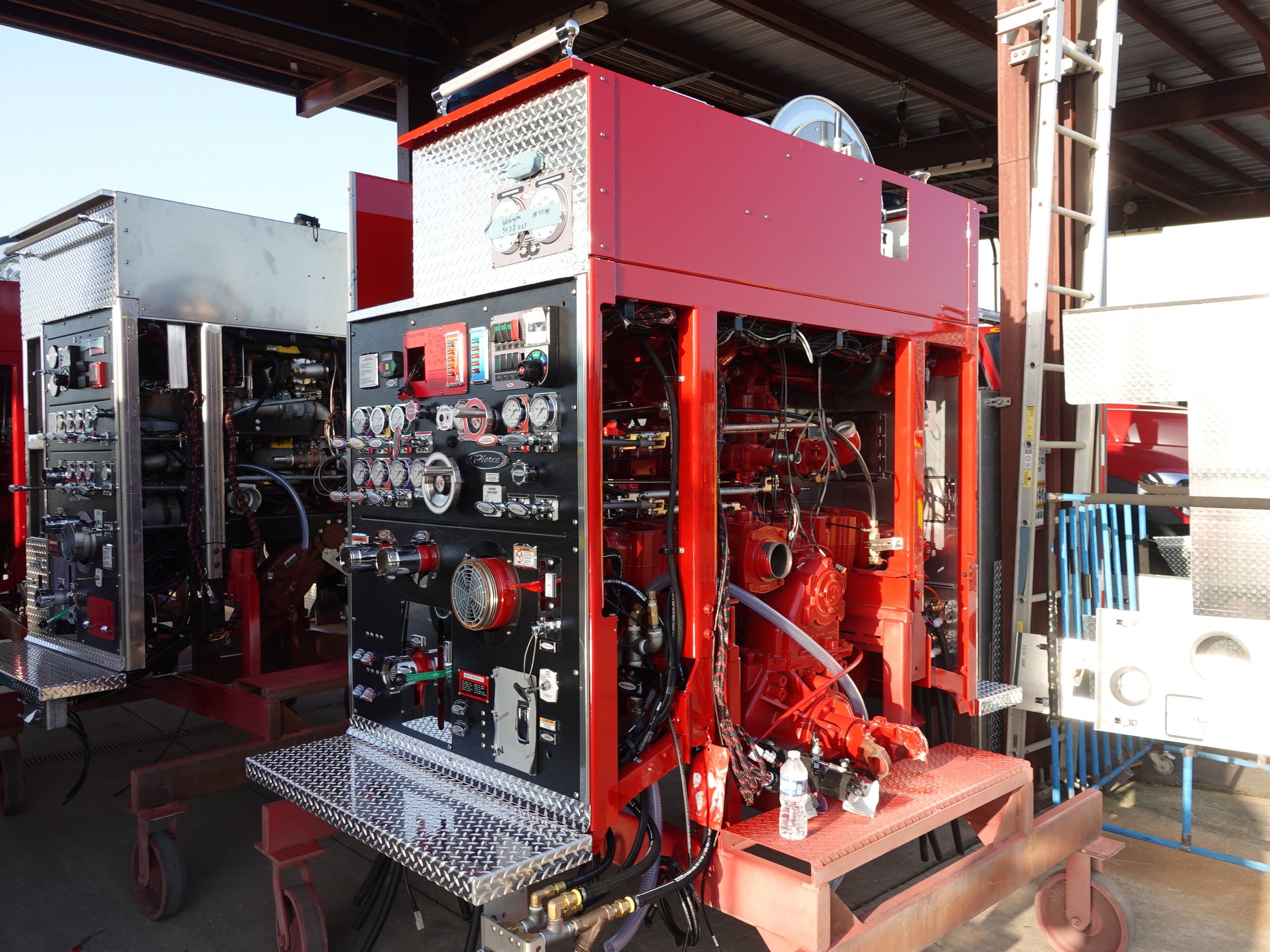

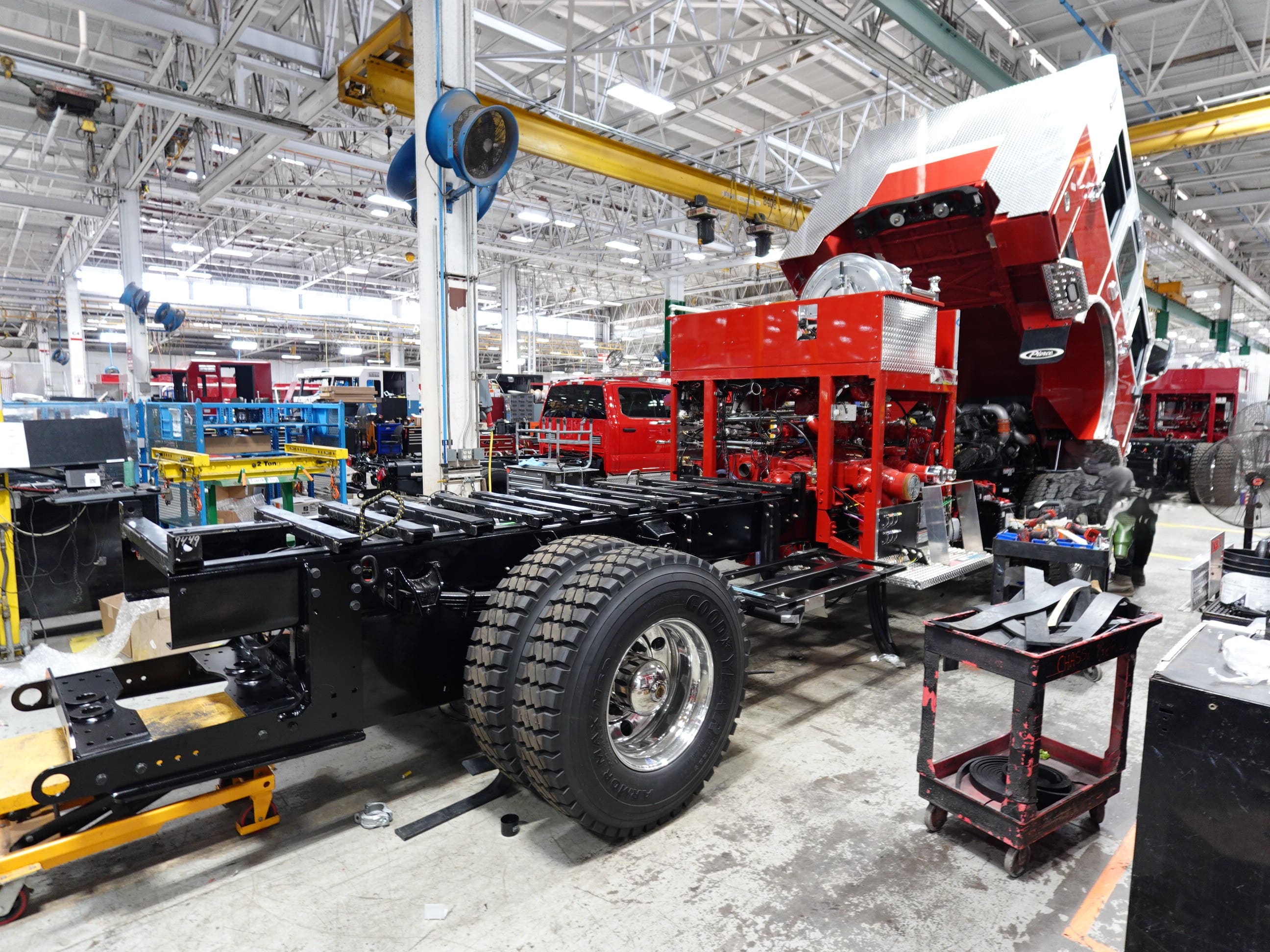

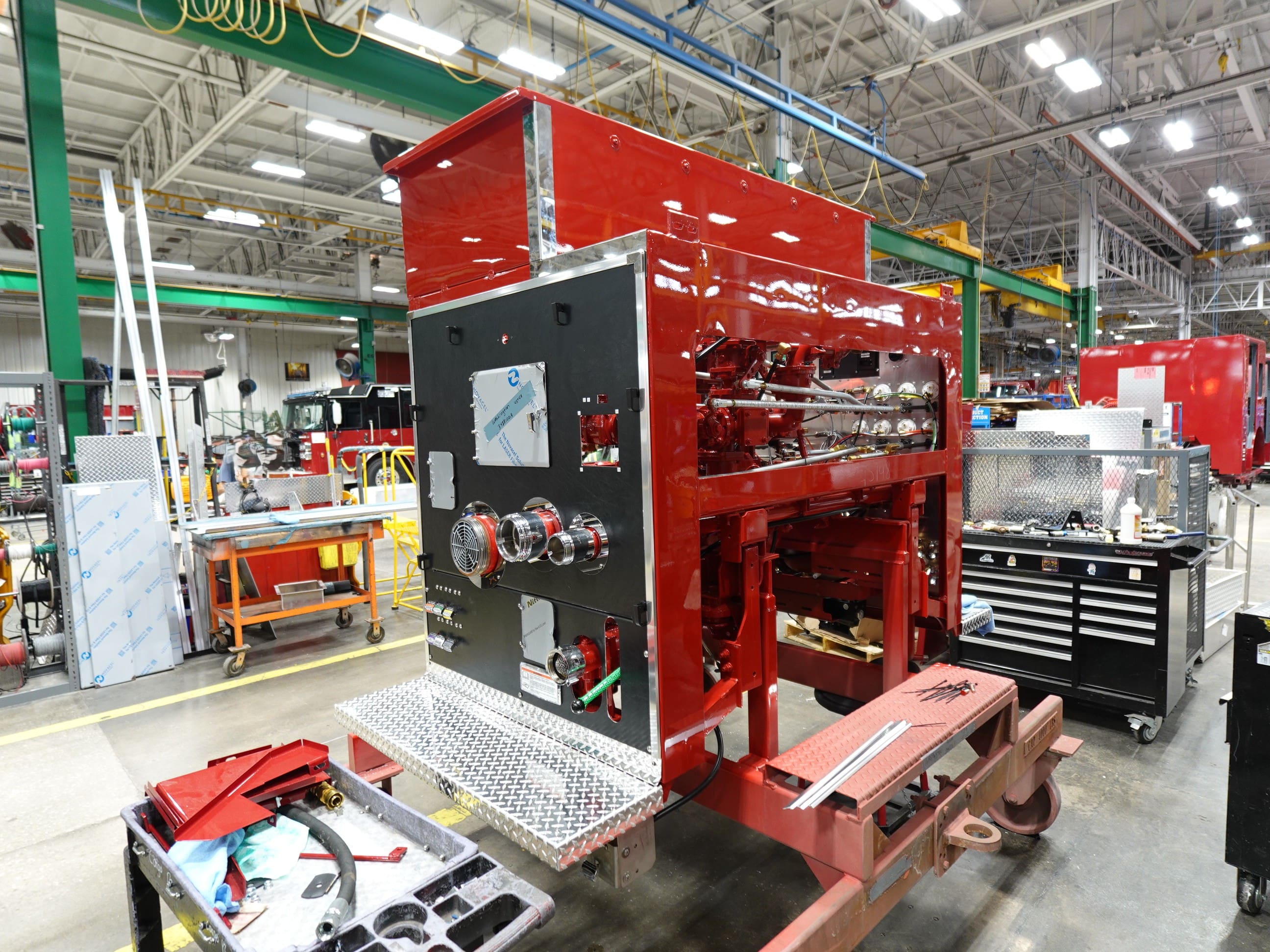

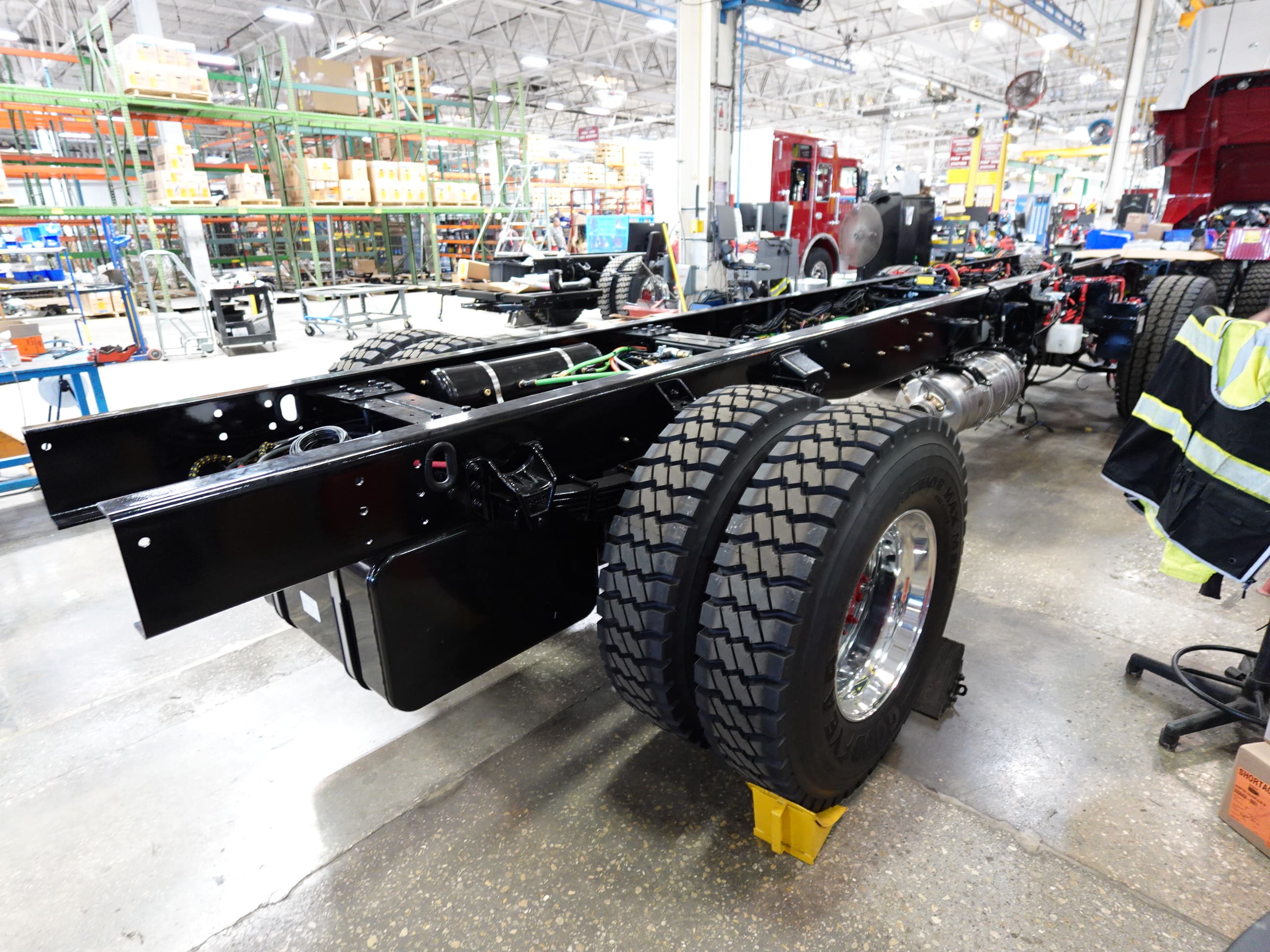

In this report, the cab and pump house were merged with the frame while the body remained staged.
08-28-26

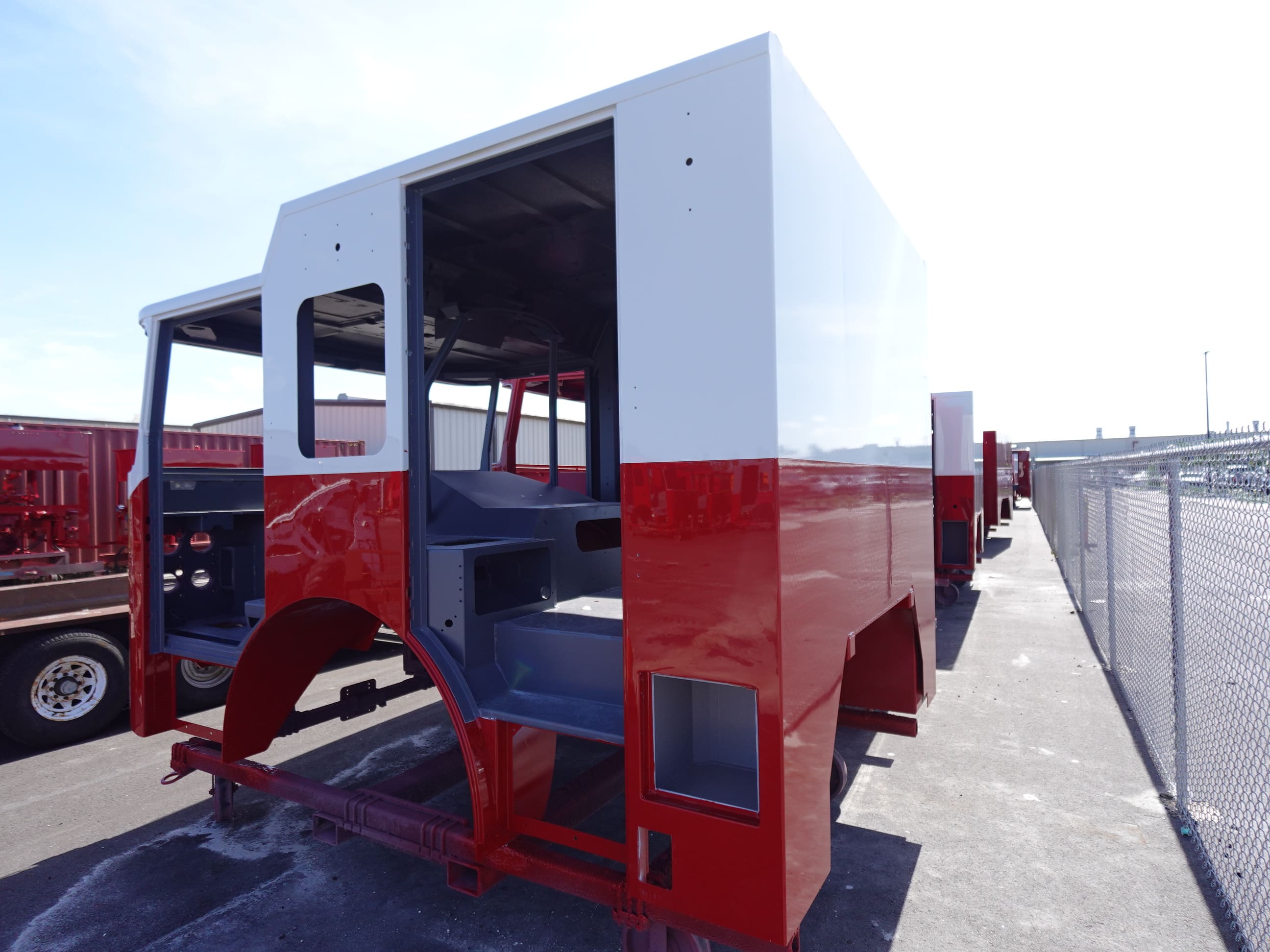

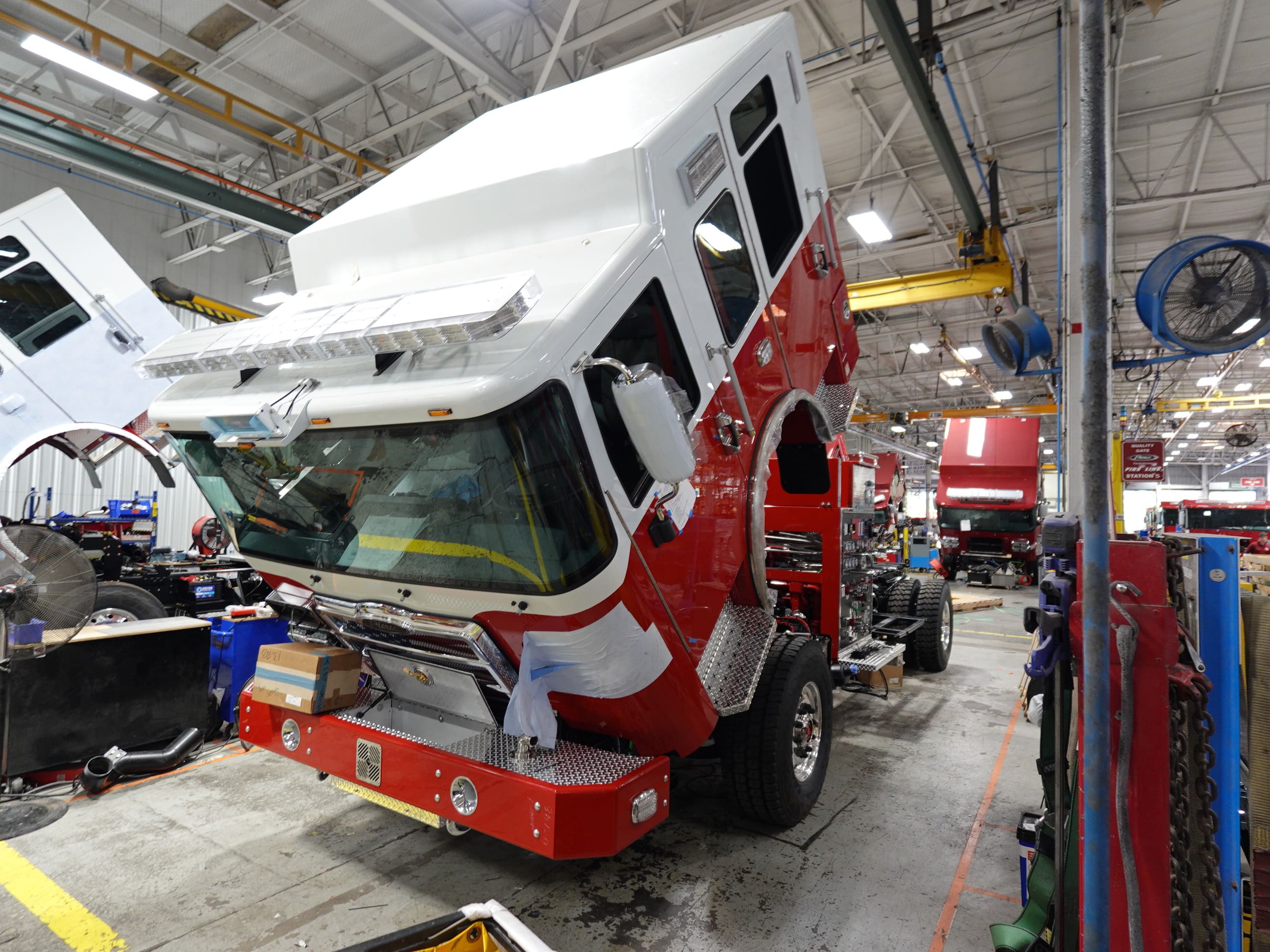

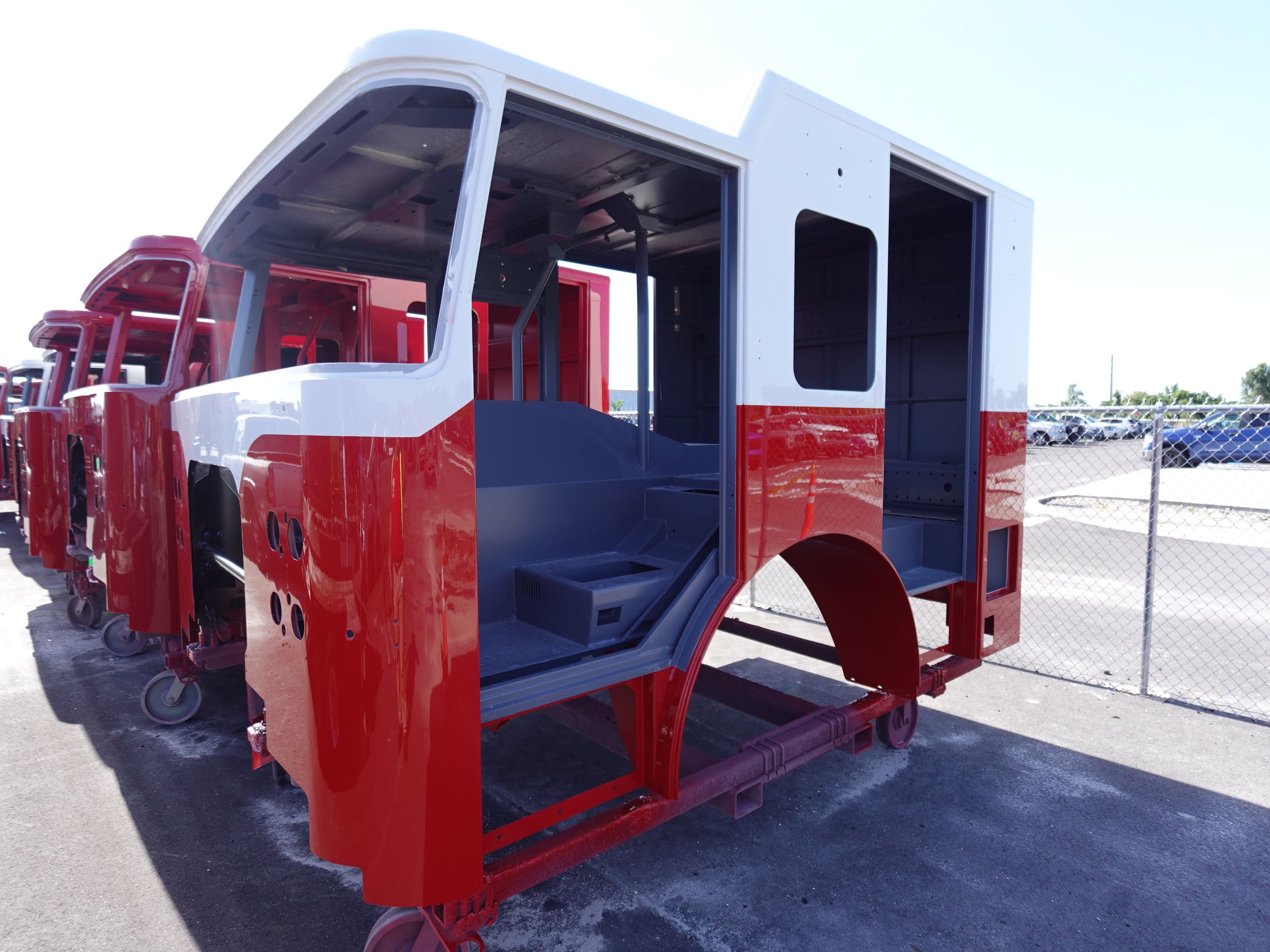

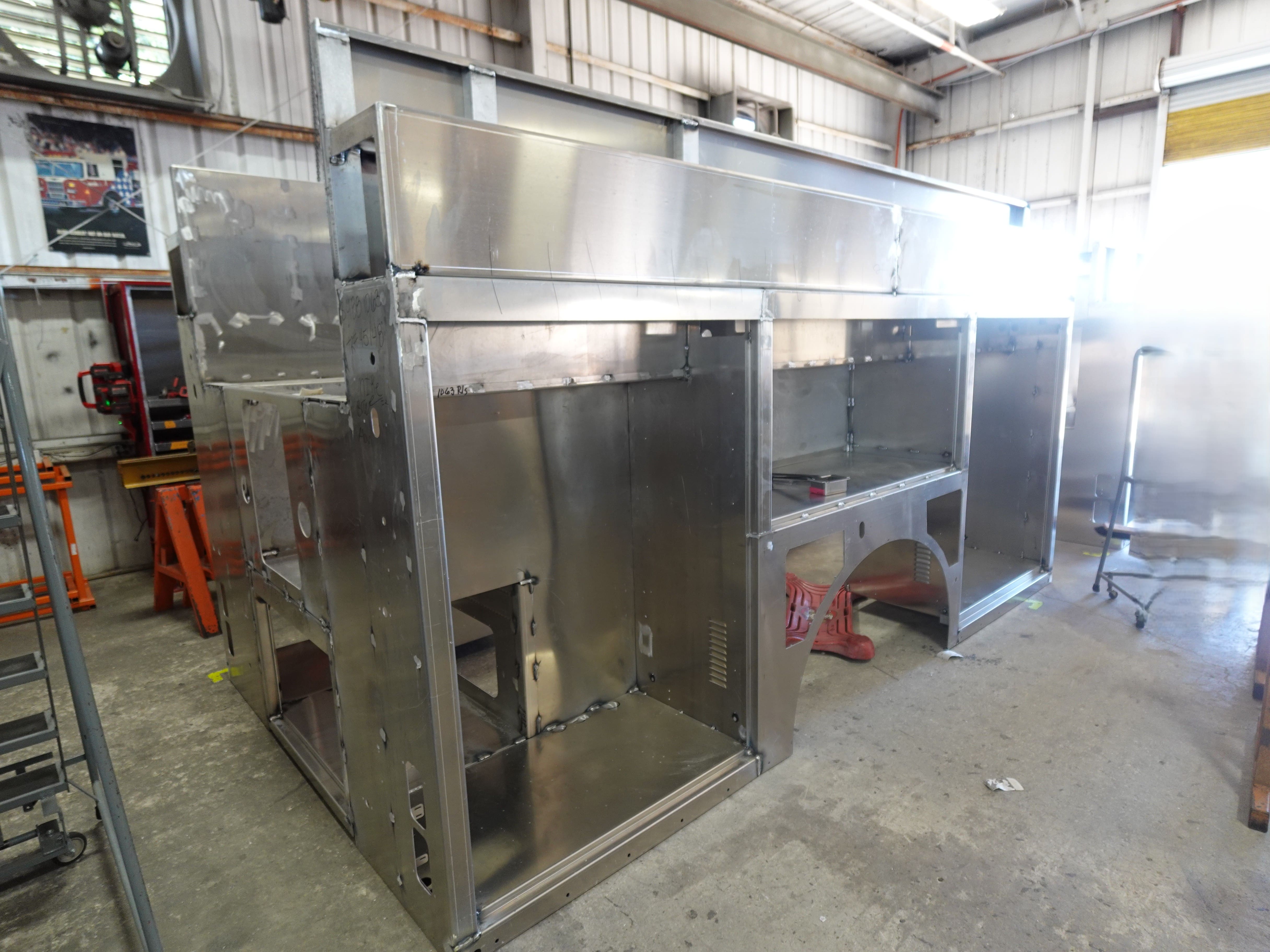

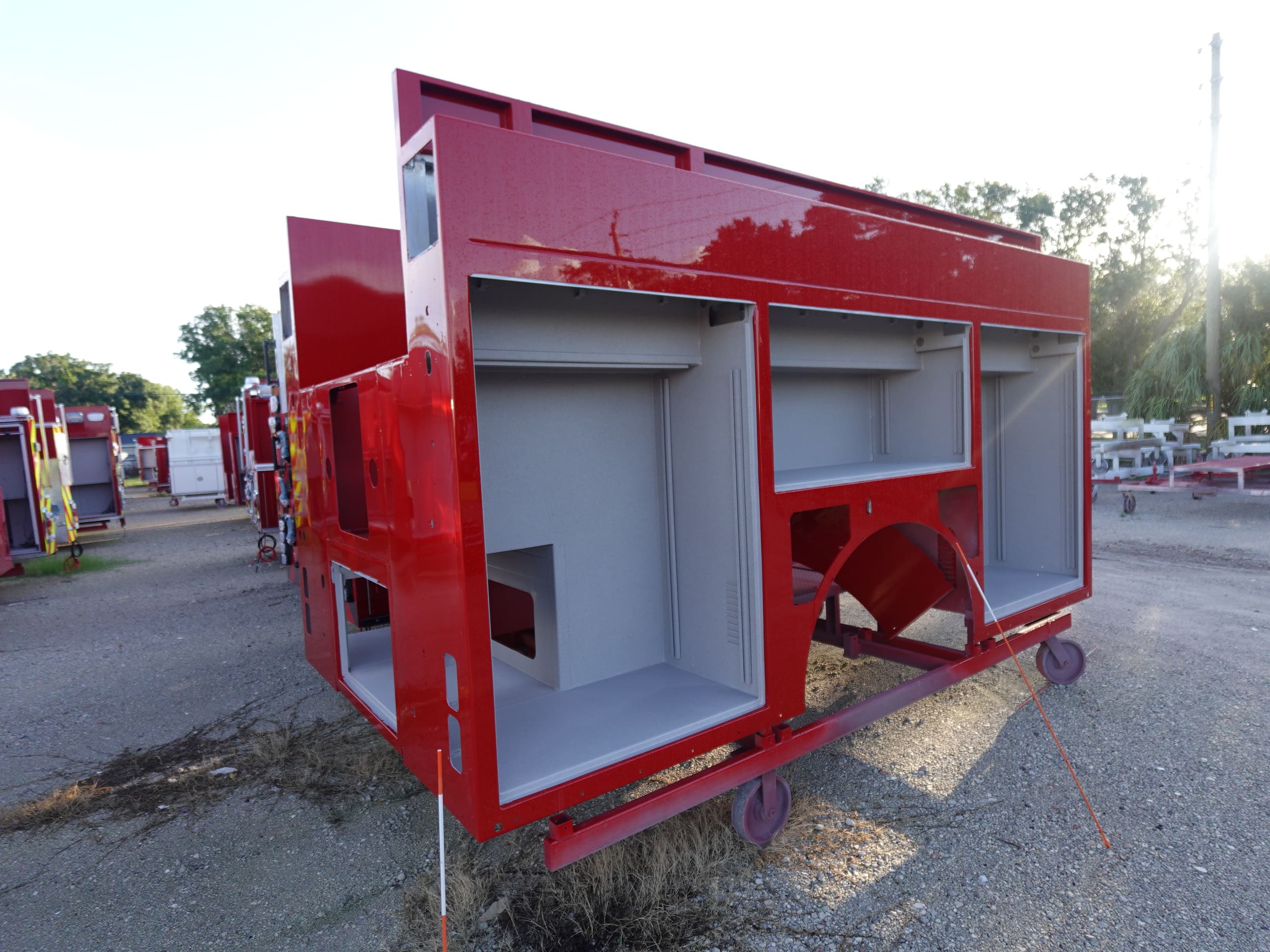

In this report, the cab completed initial assembly, the frame

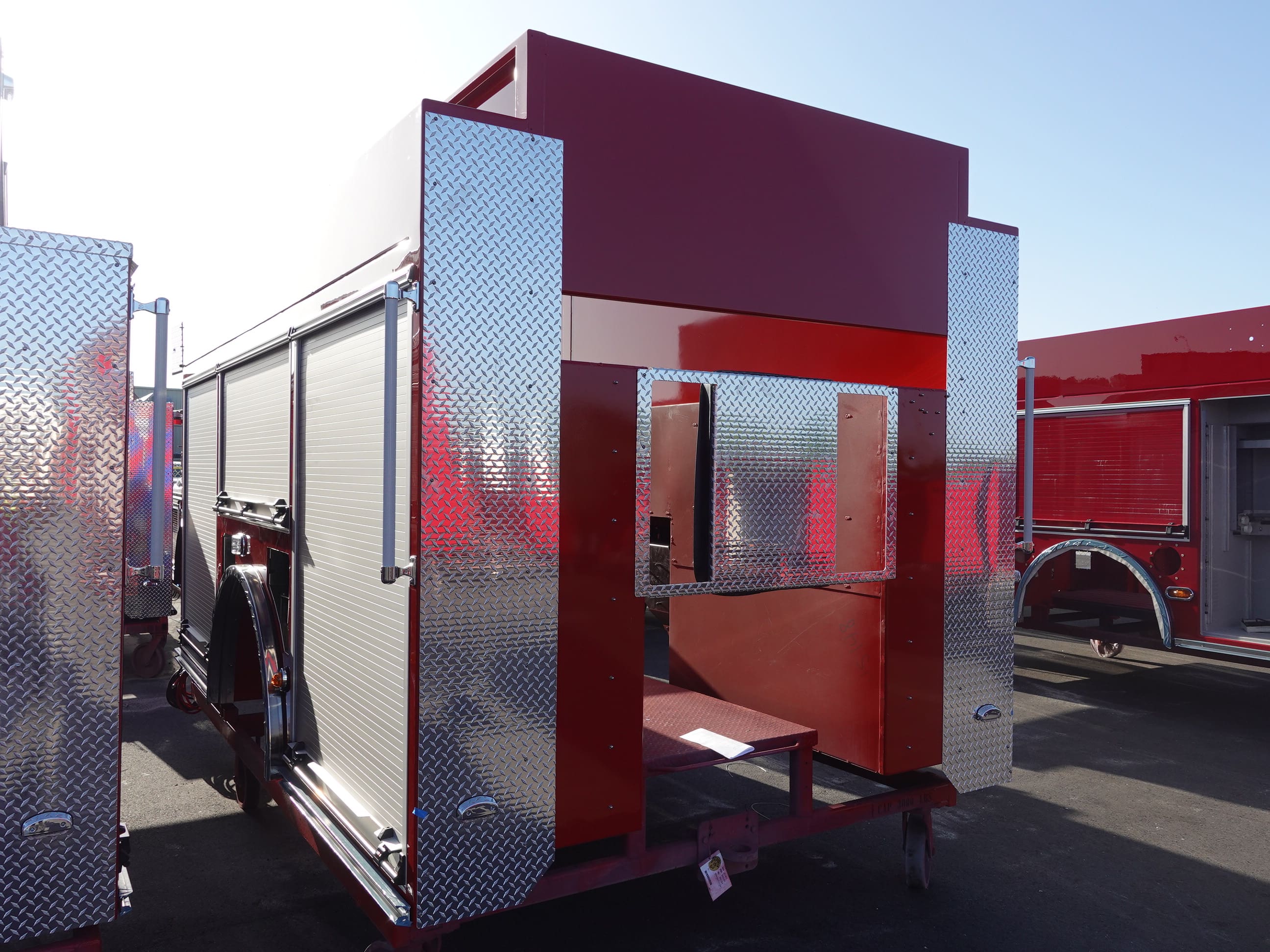

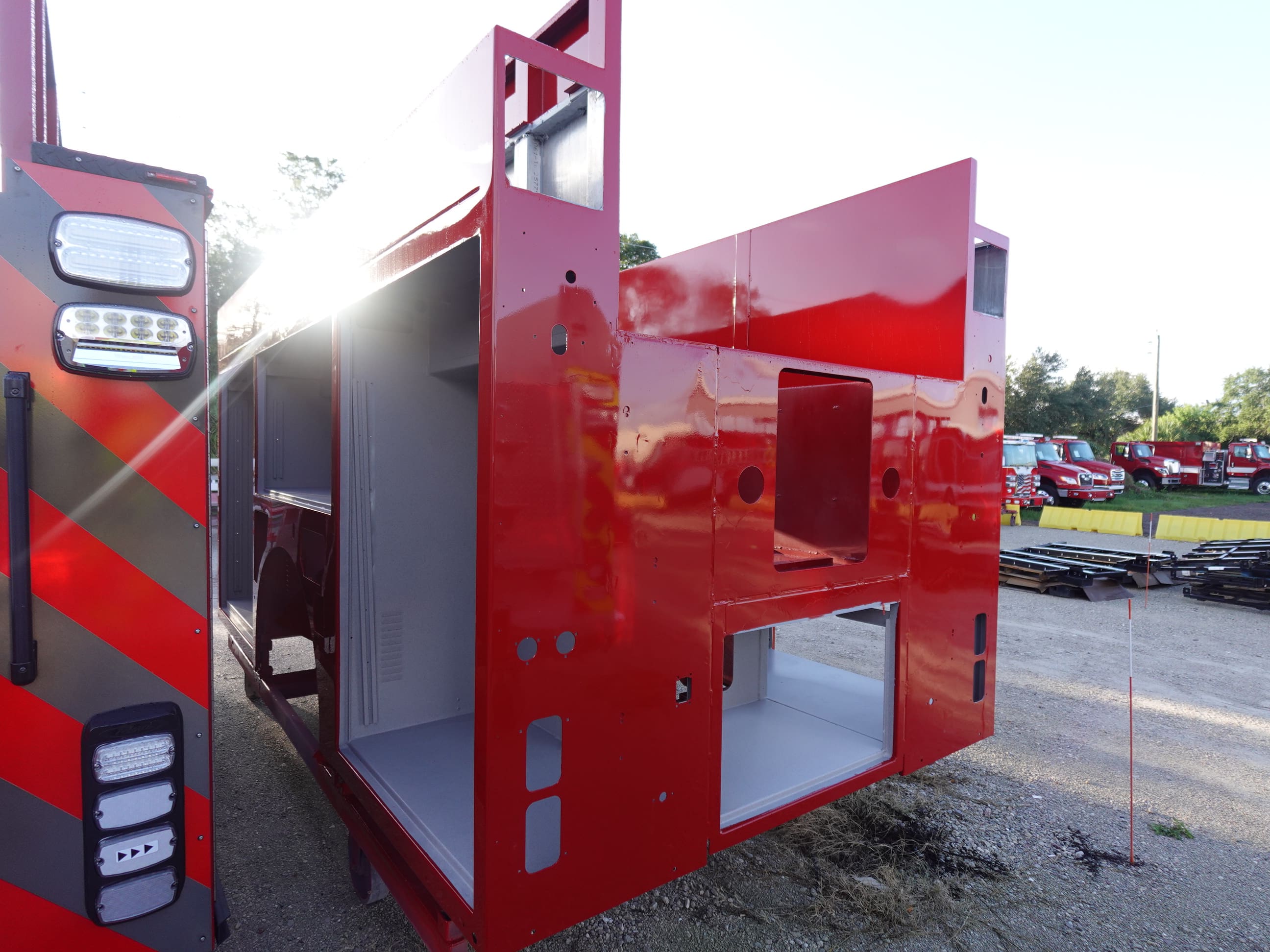

build continued, and the pump house and the body remained
staged.
08-21-26

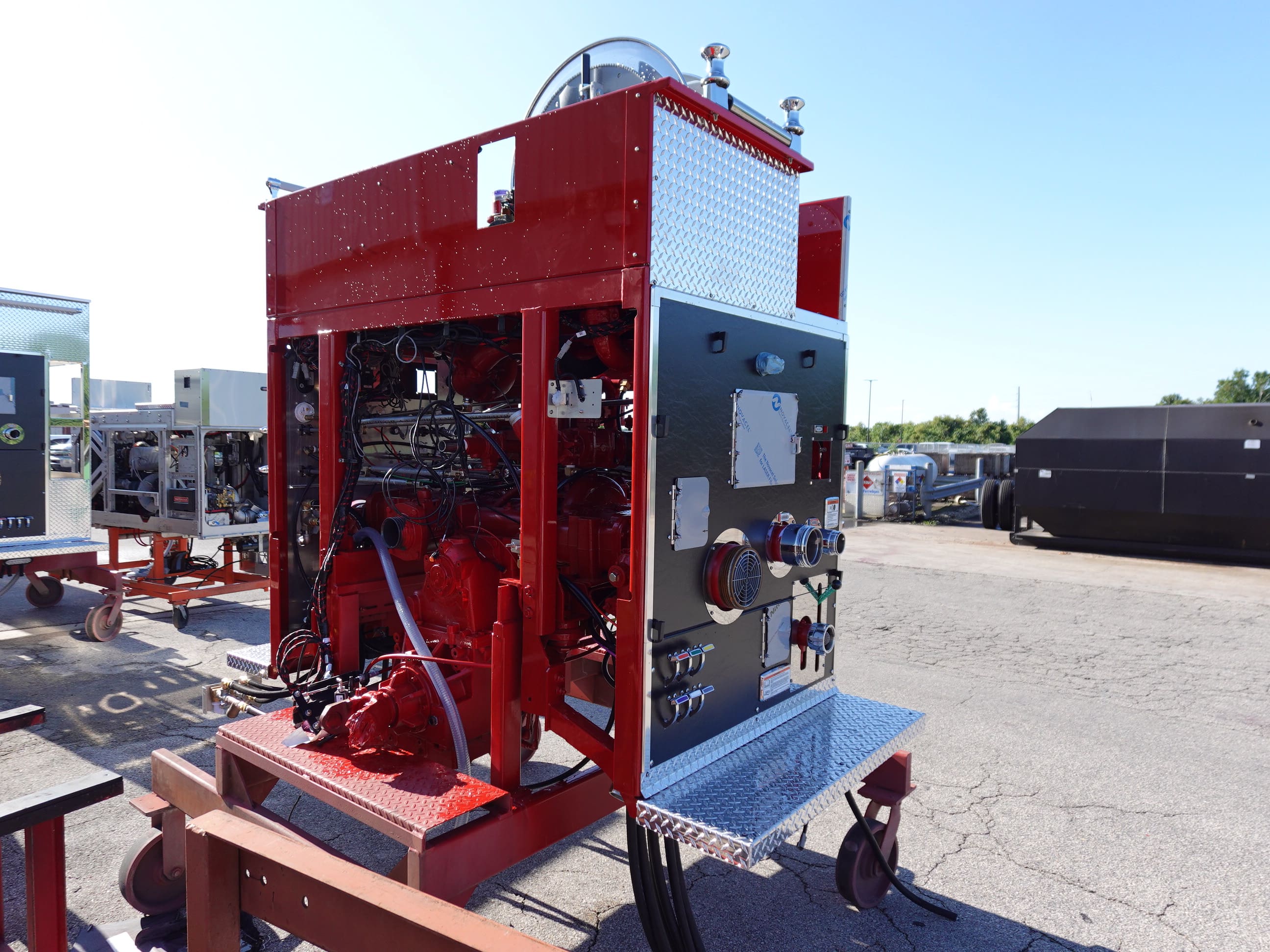

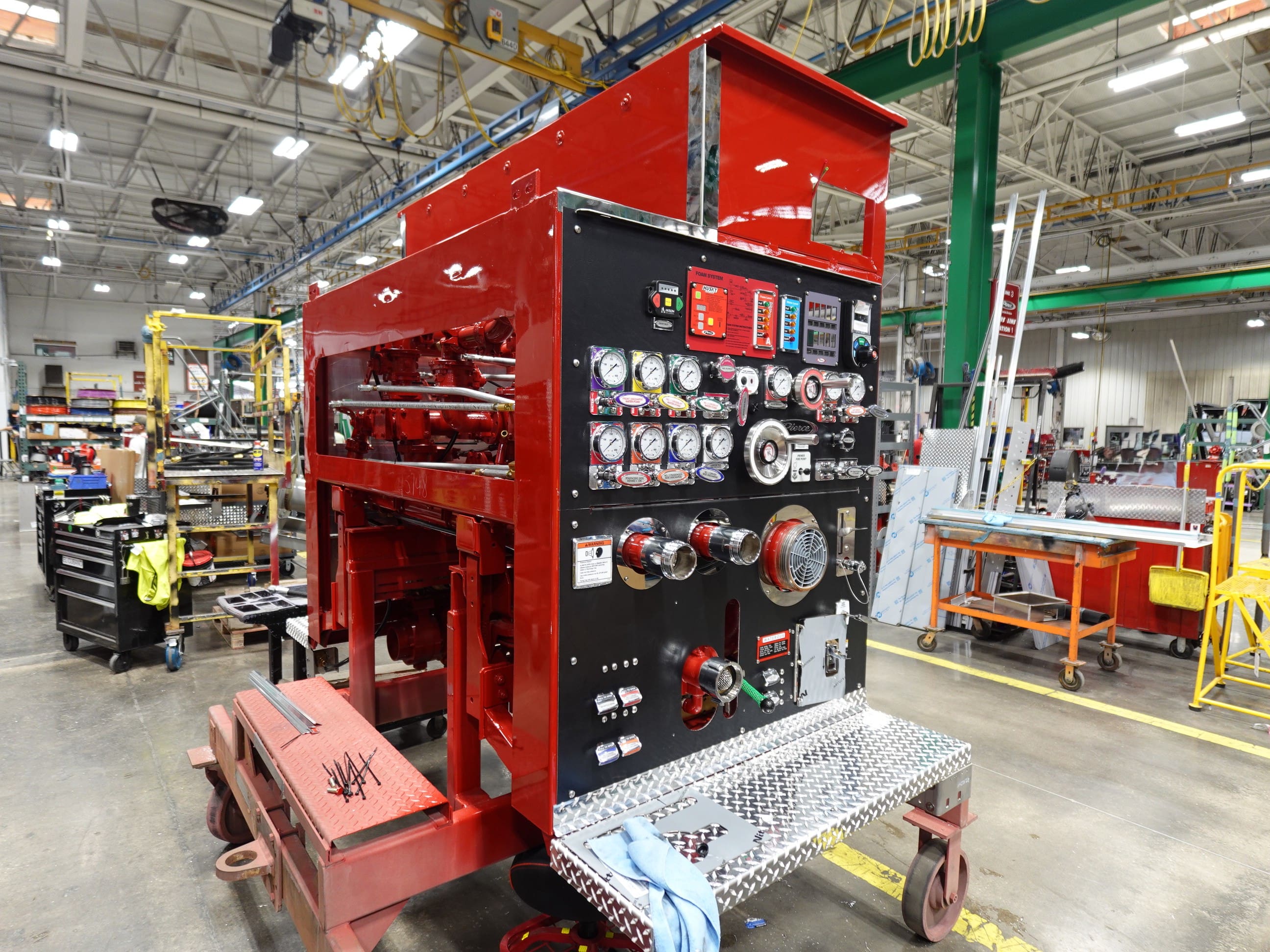

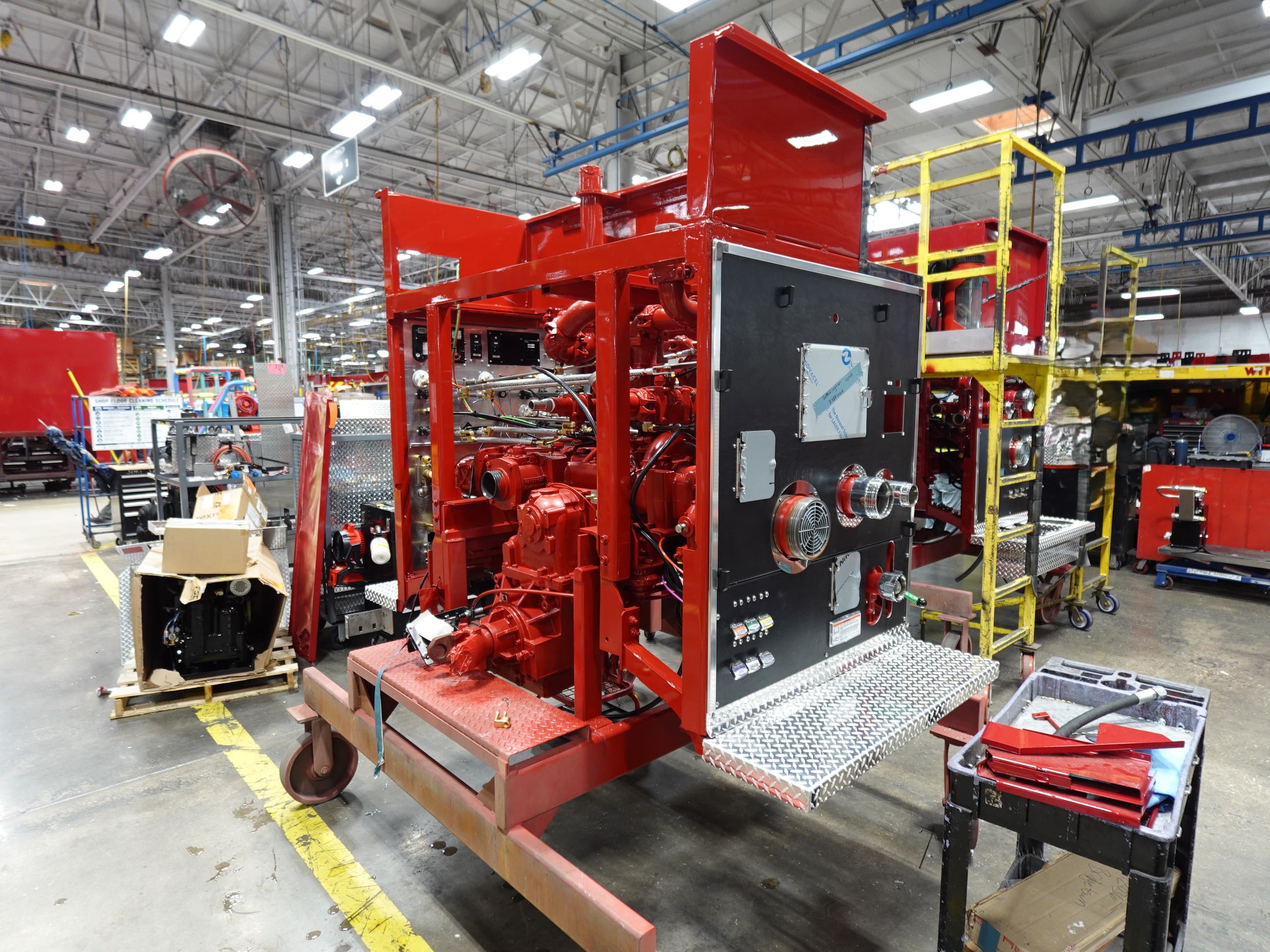

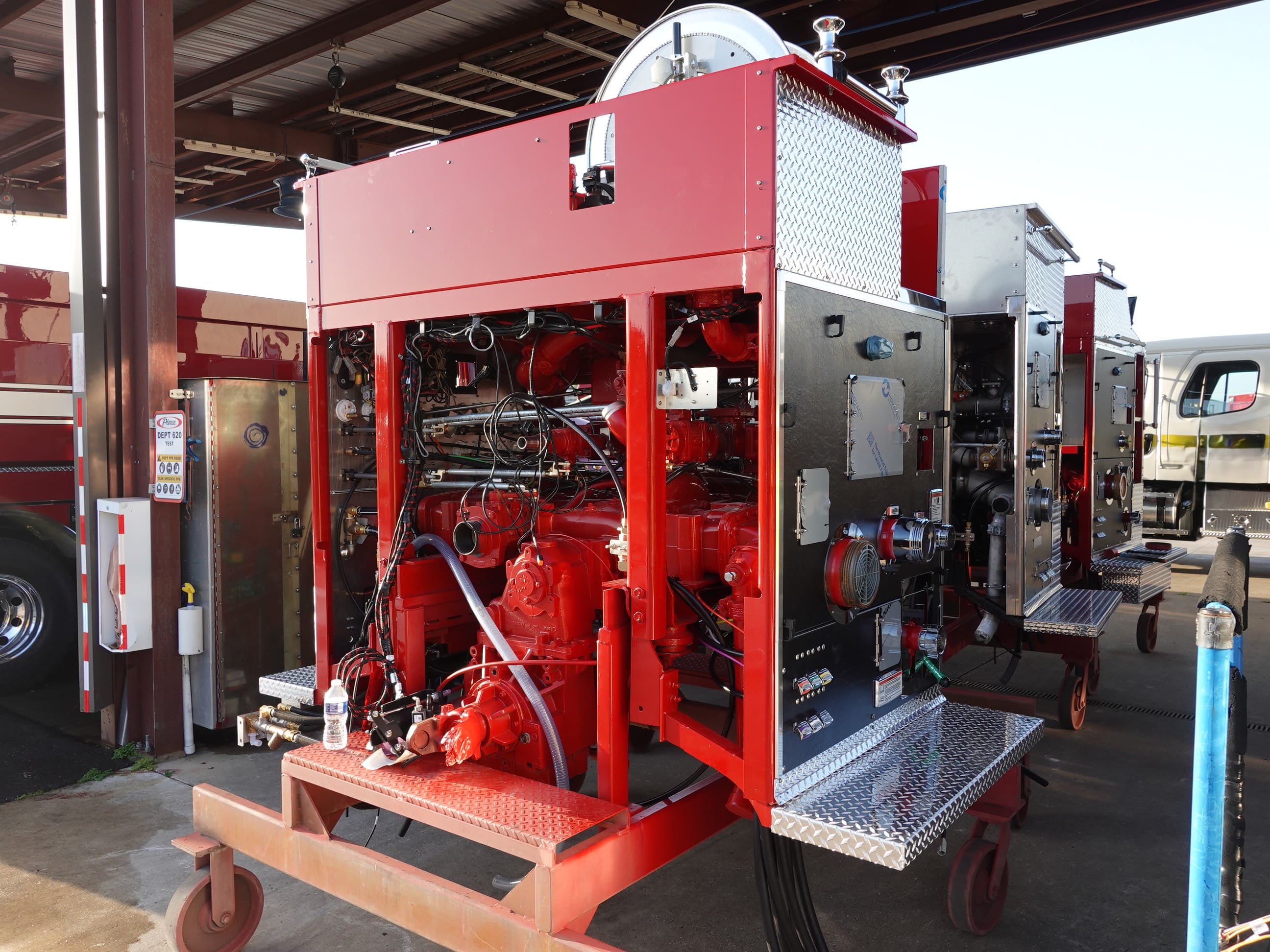

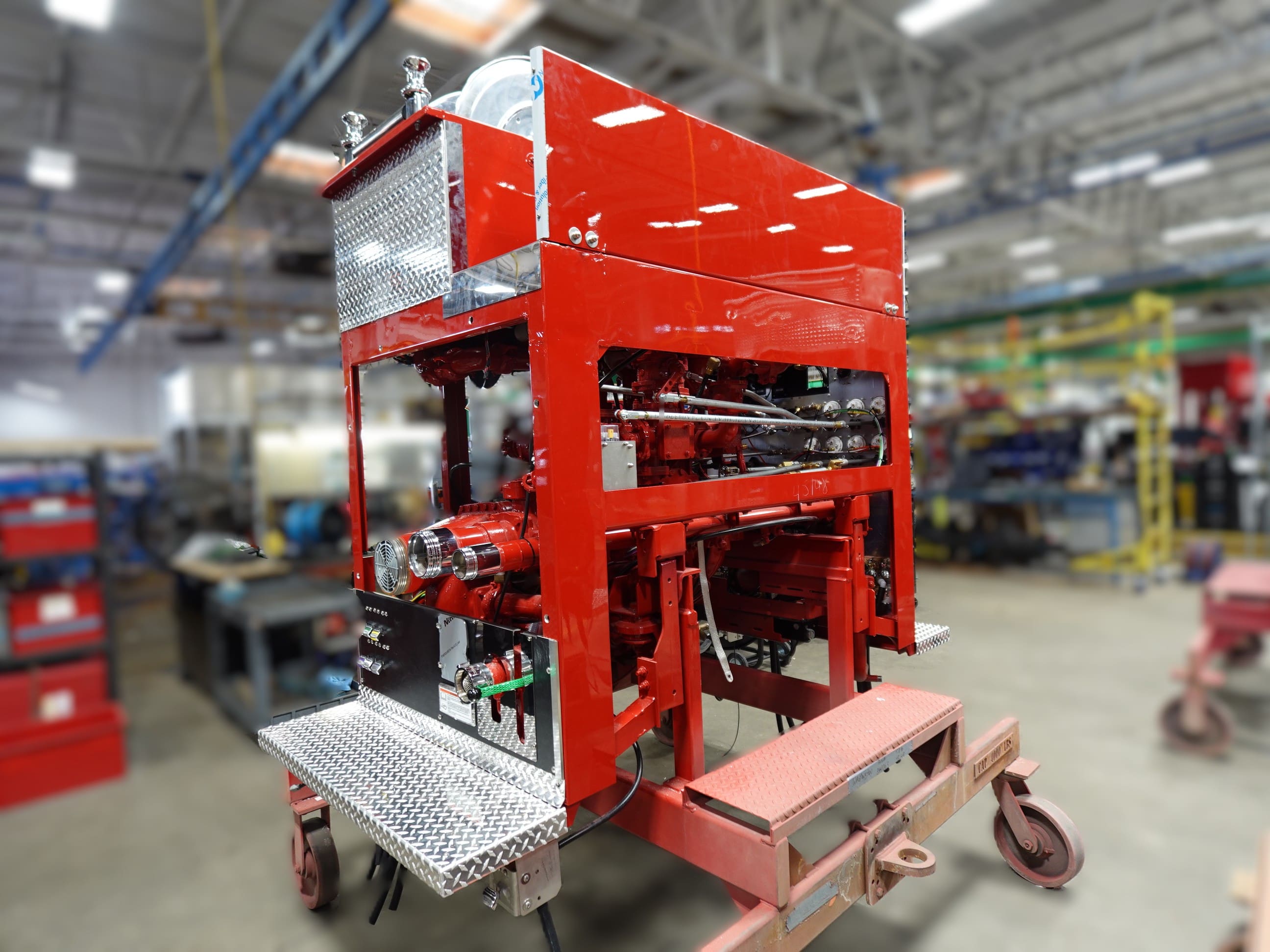

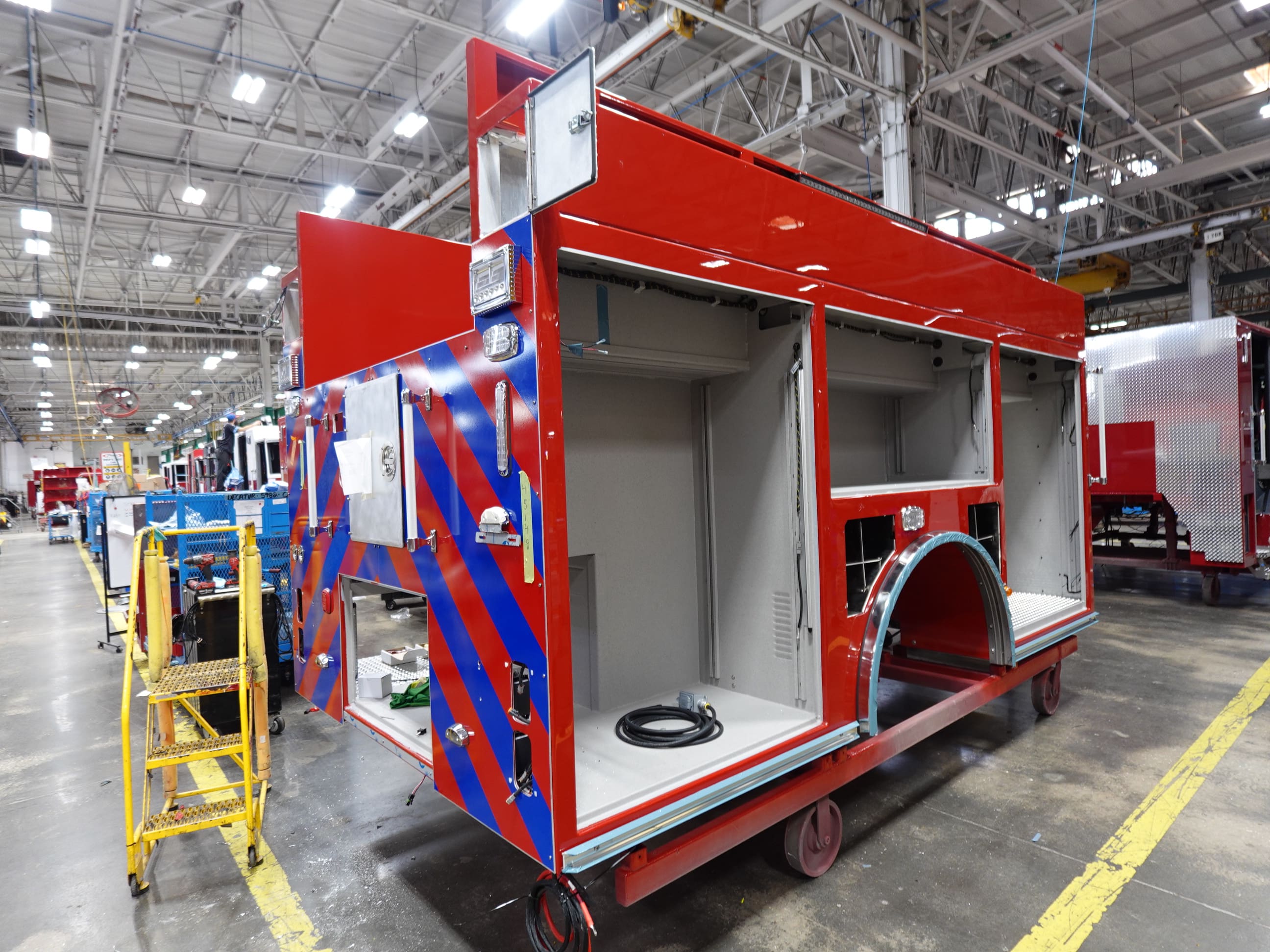

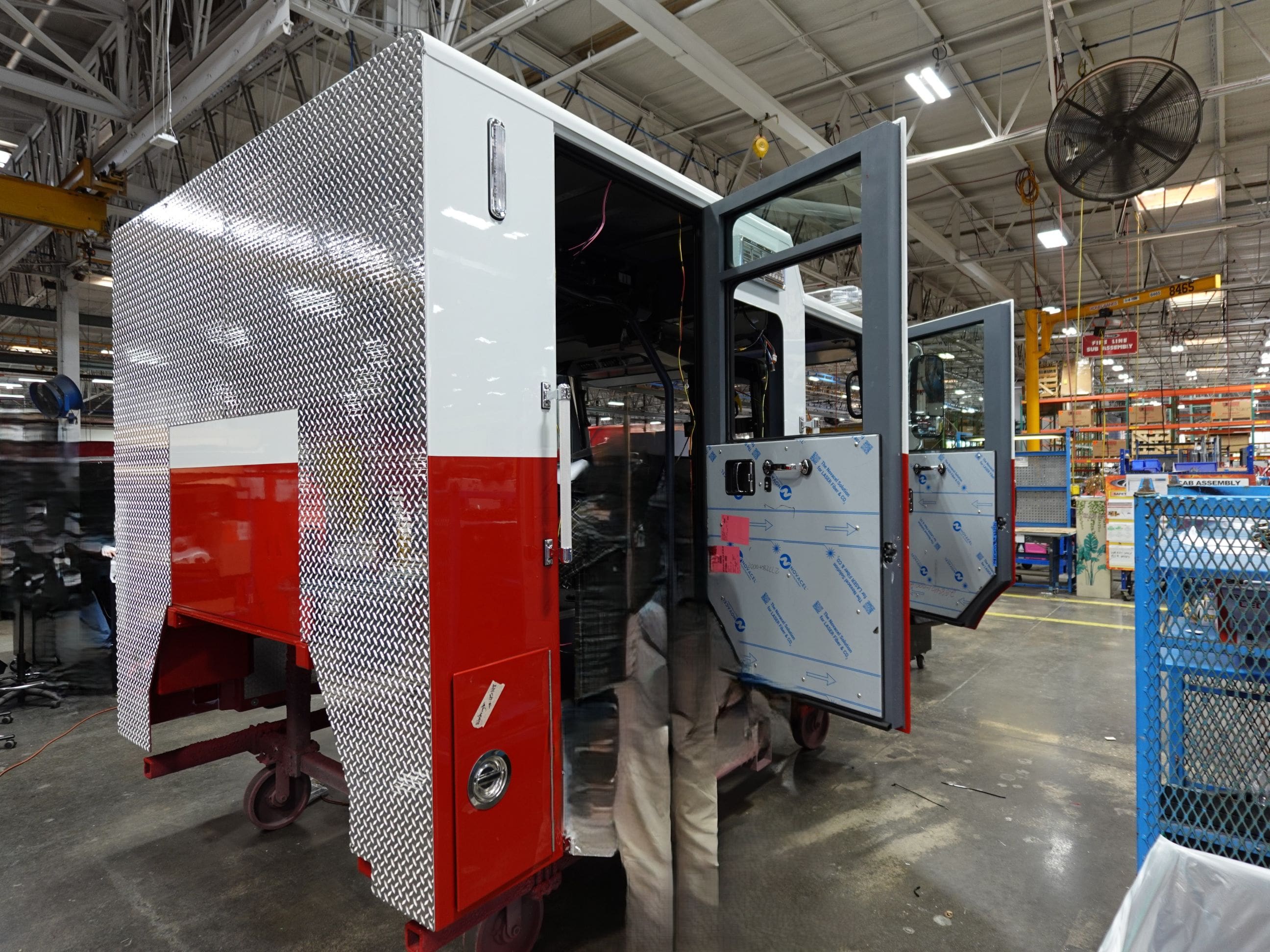

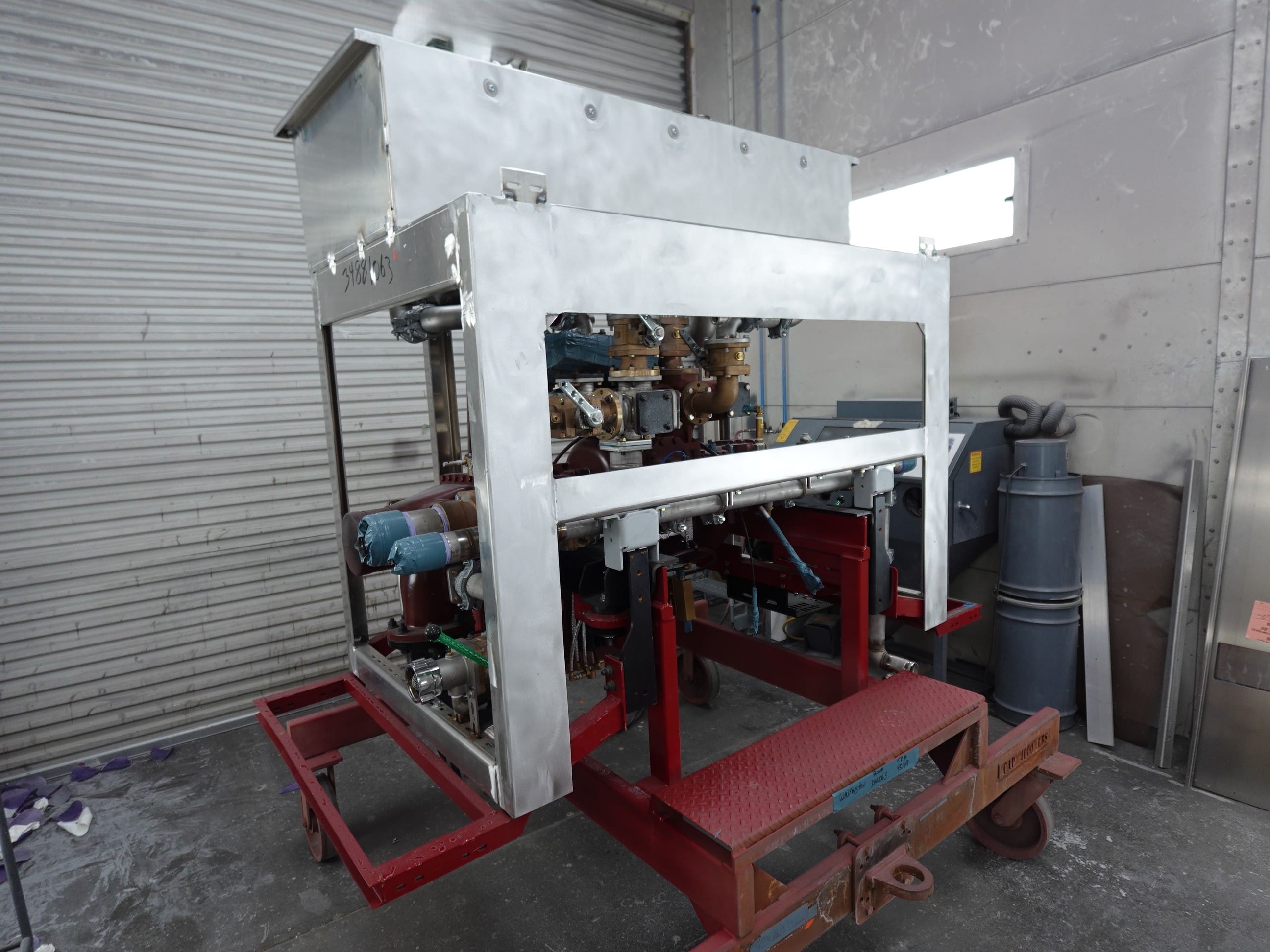

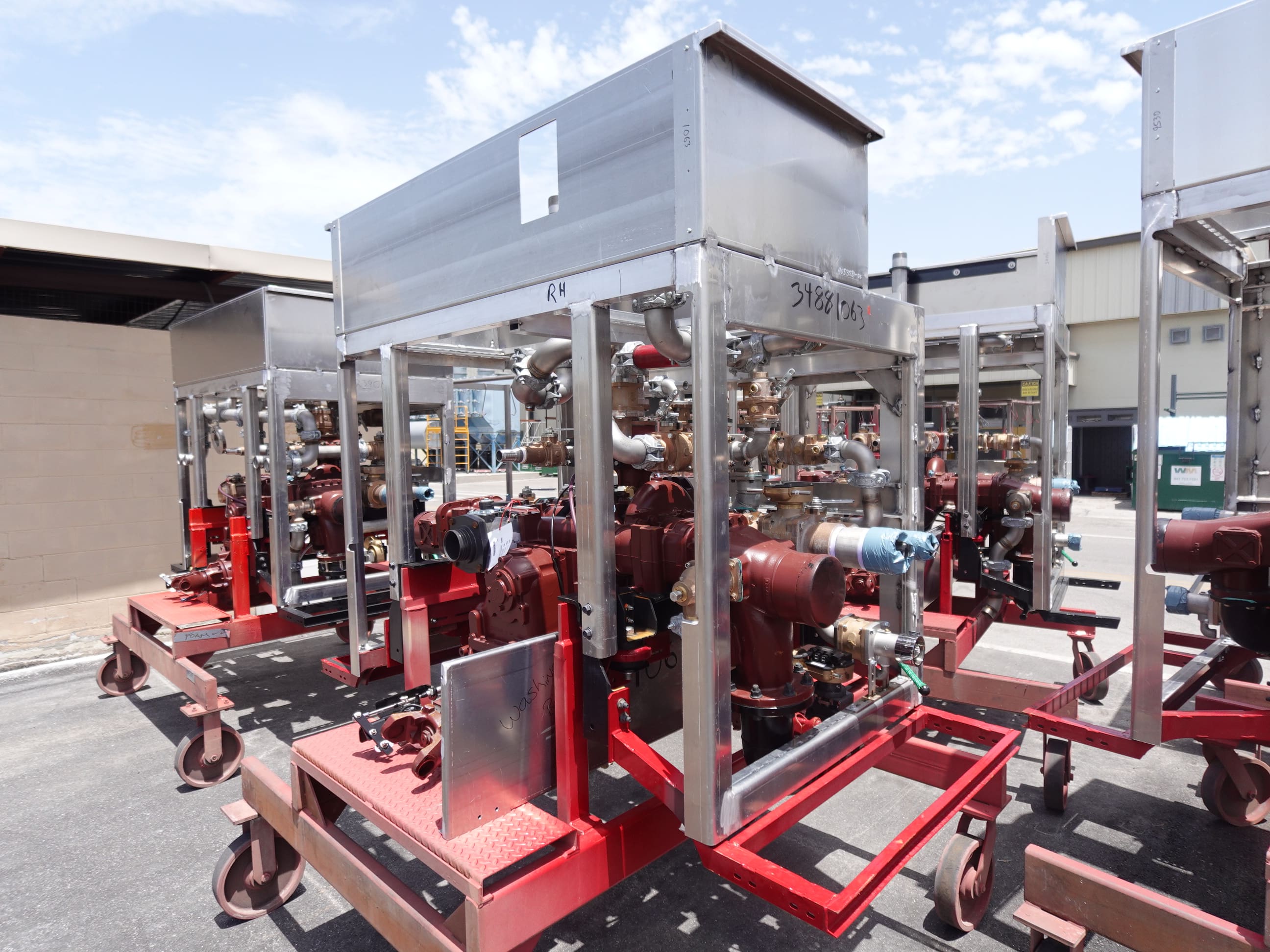

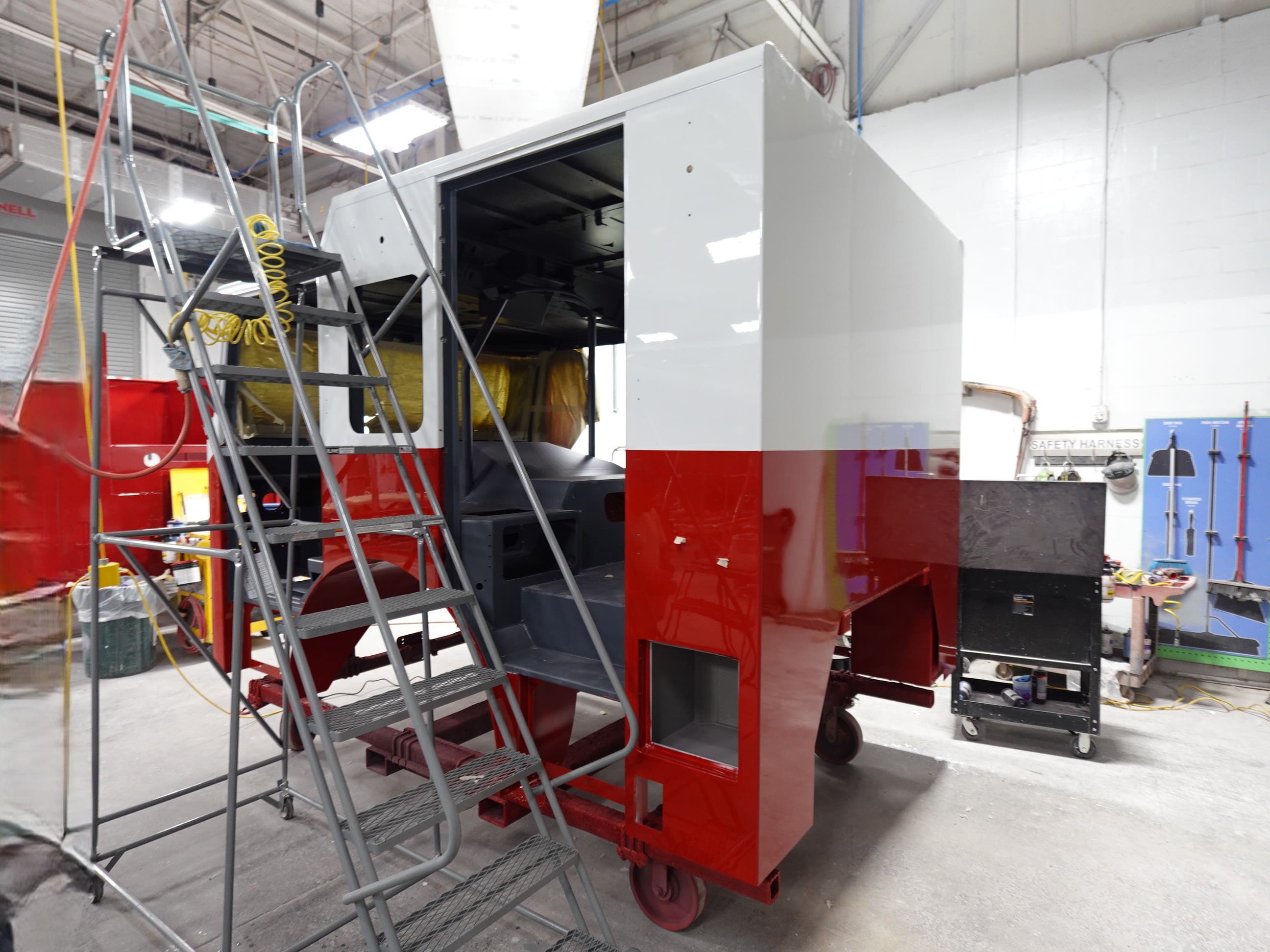

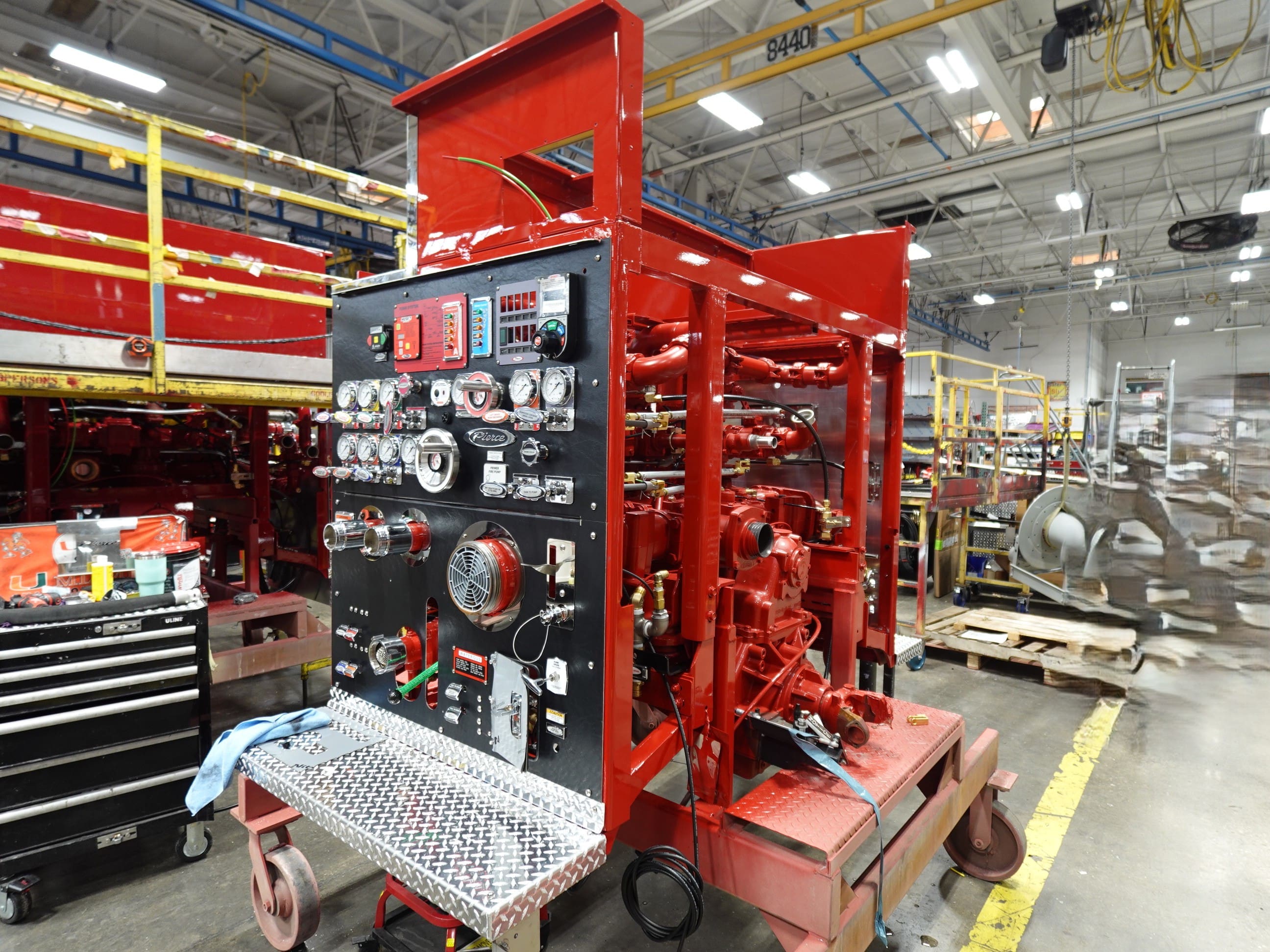

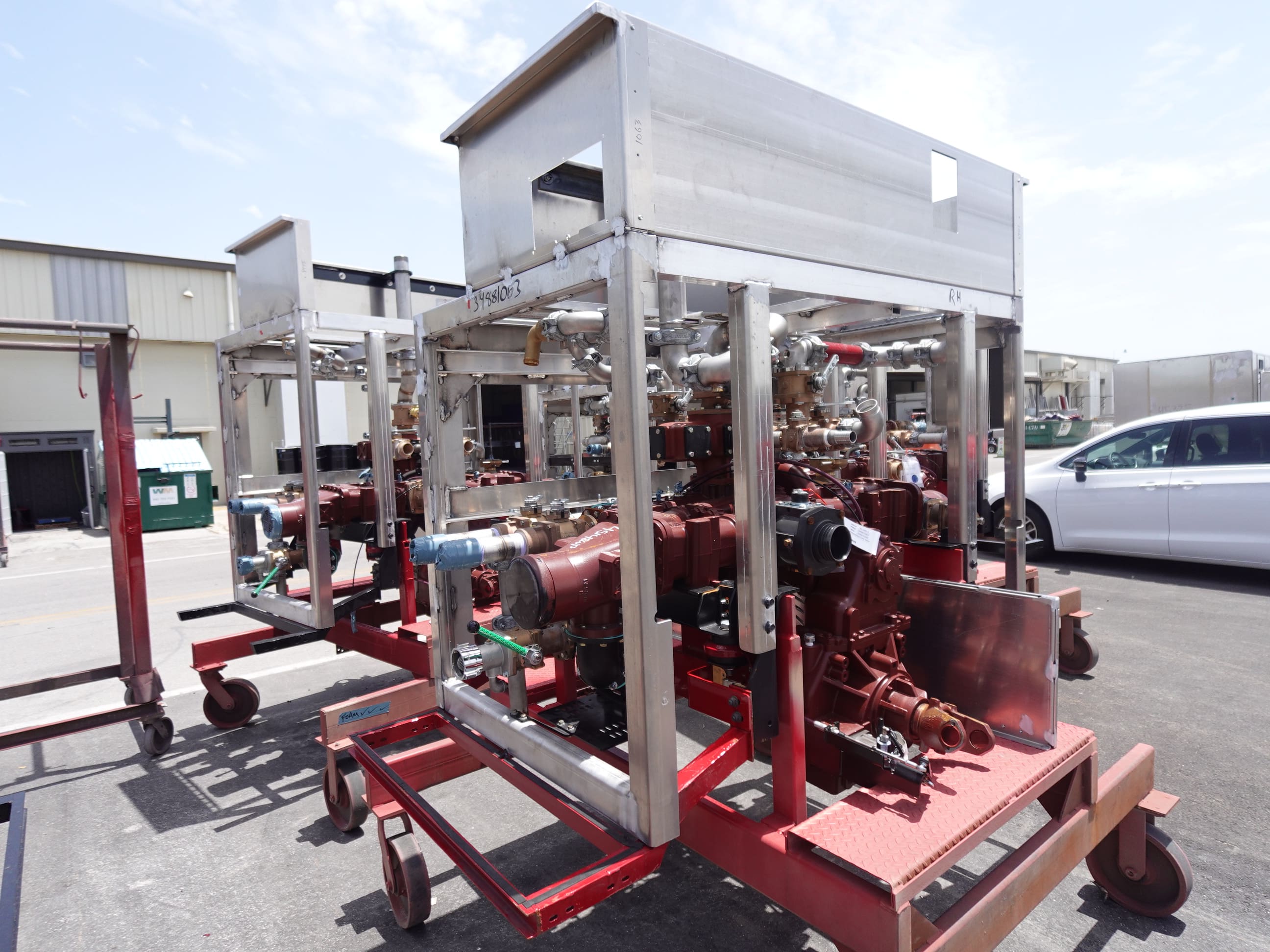

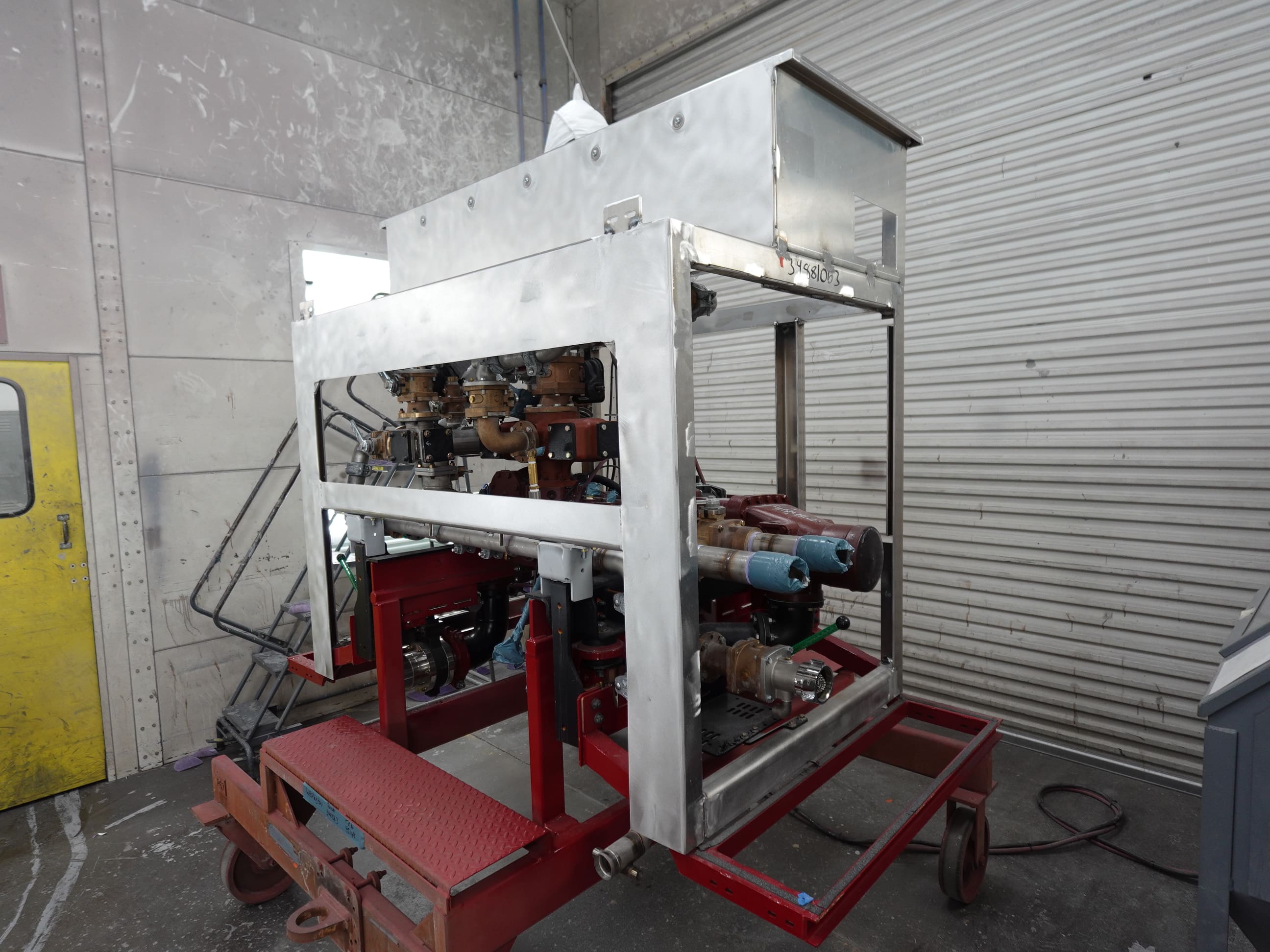

In this report, the cab began initial assembly, the frame remained staged, the pump house completed initial assembly and began testing, and the body completed initial assembly.
08-14-26
In this report, the cab remained staged, the frame was staged, the pump house continued initial
assembly, and the body continued initial assembly.
08-07-26
In this report, the cab remained staged, the frame was staged, the pump house continued initial assembly, and the body began initial assembly.

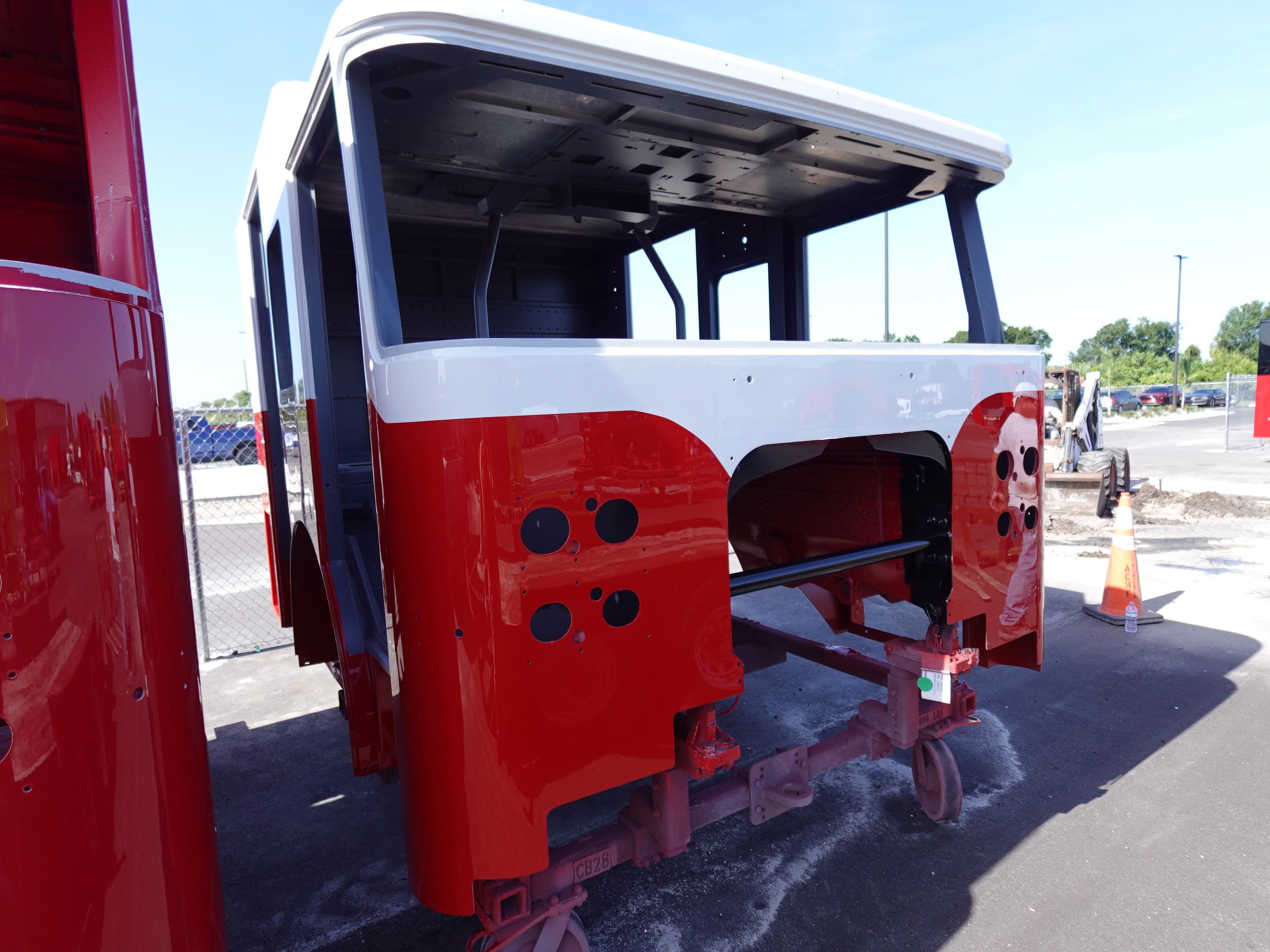

07-31-26

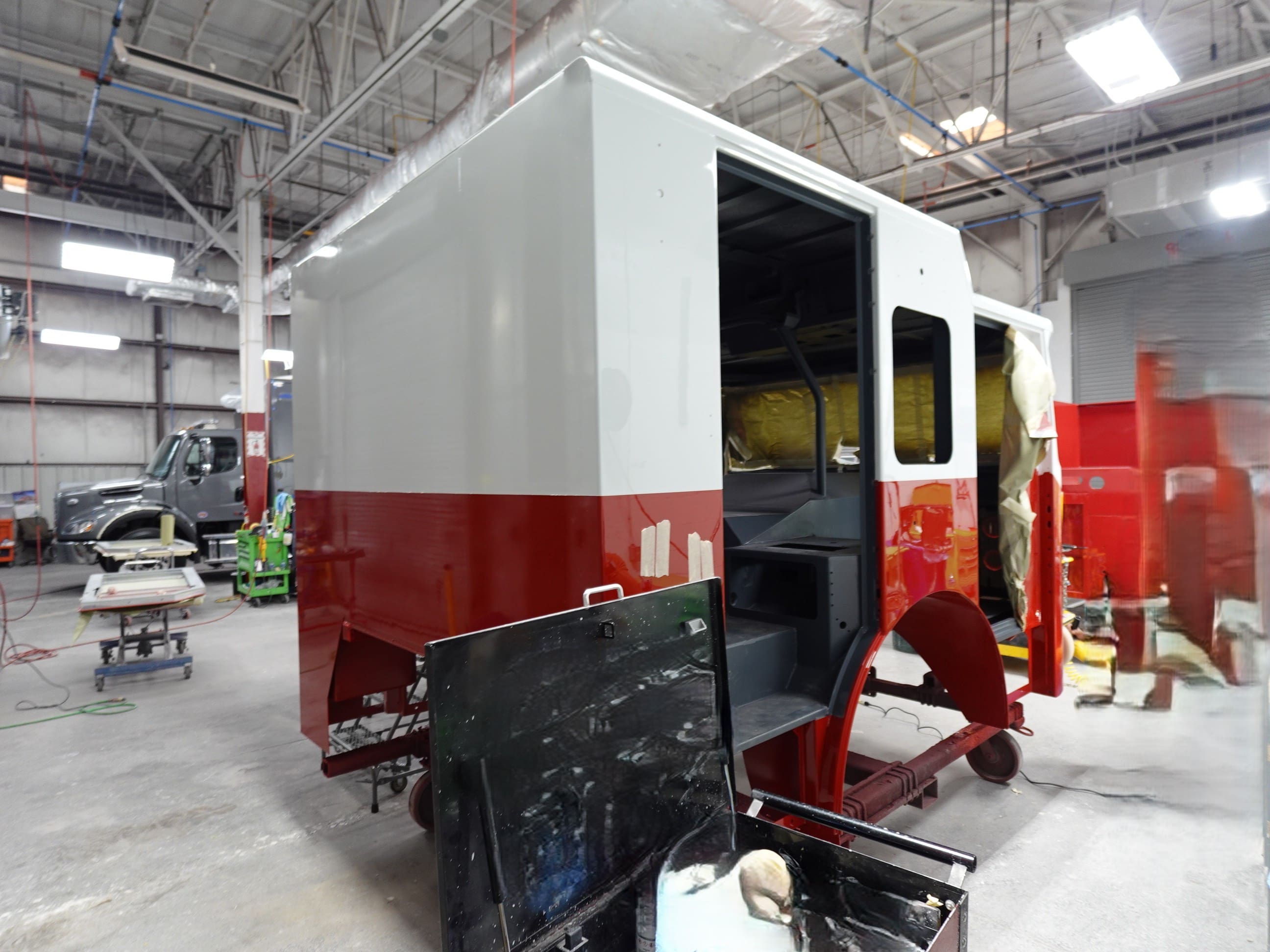

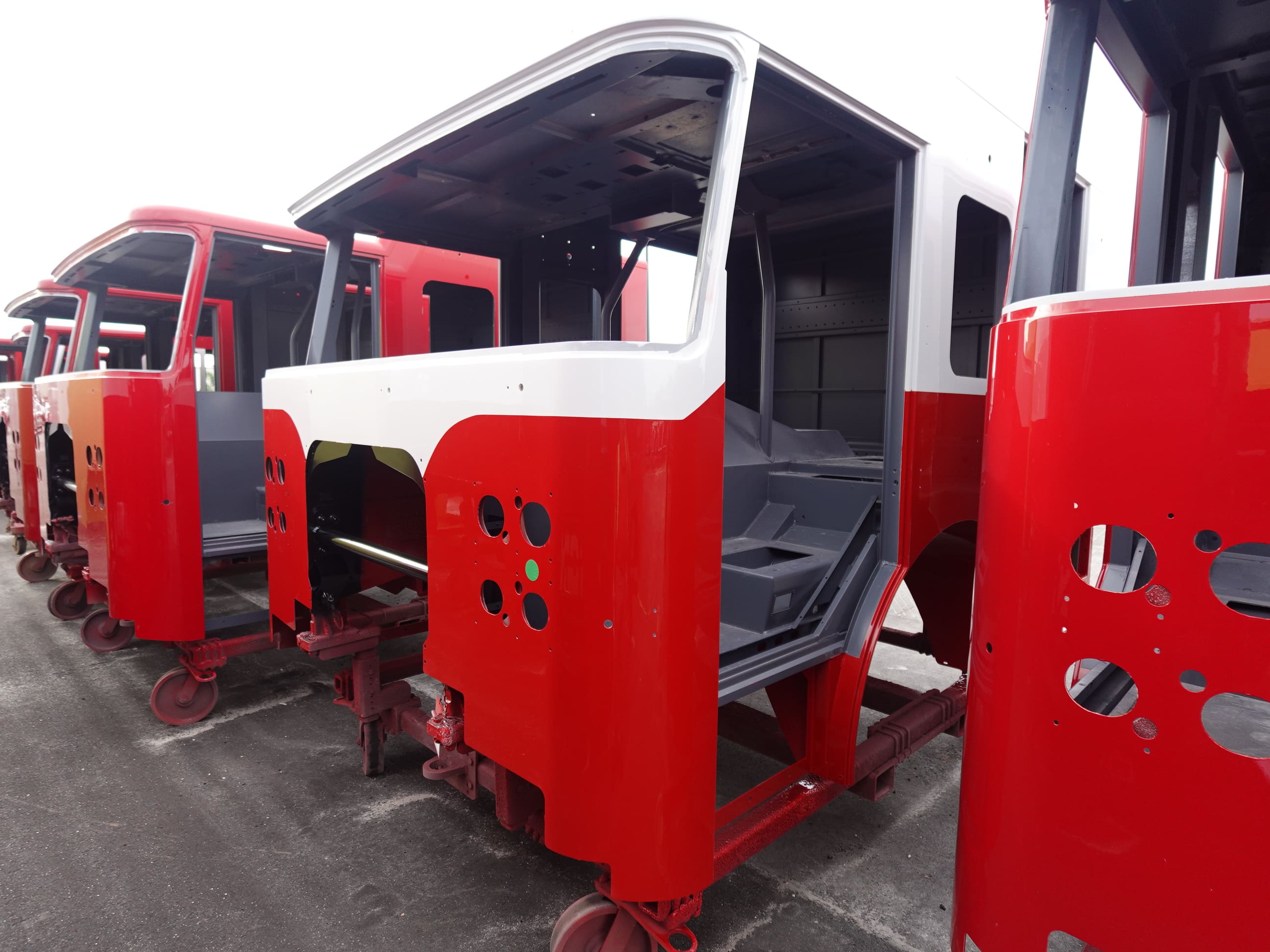

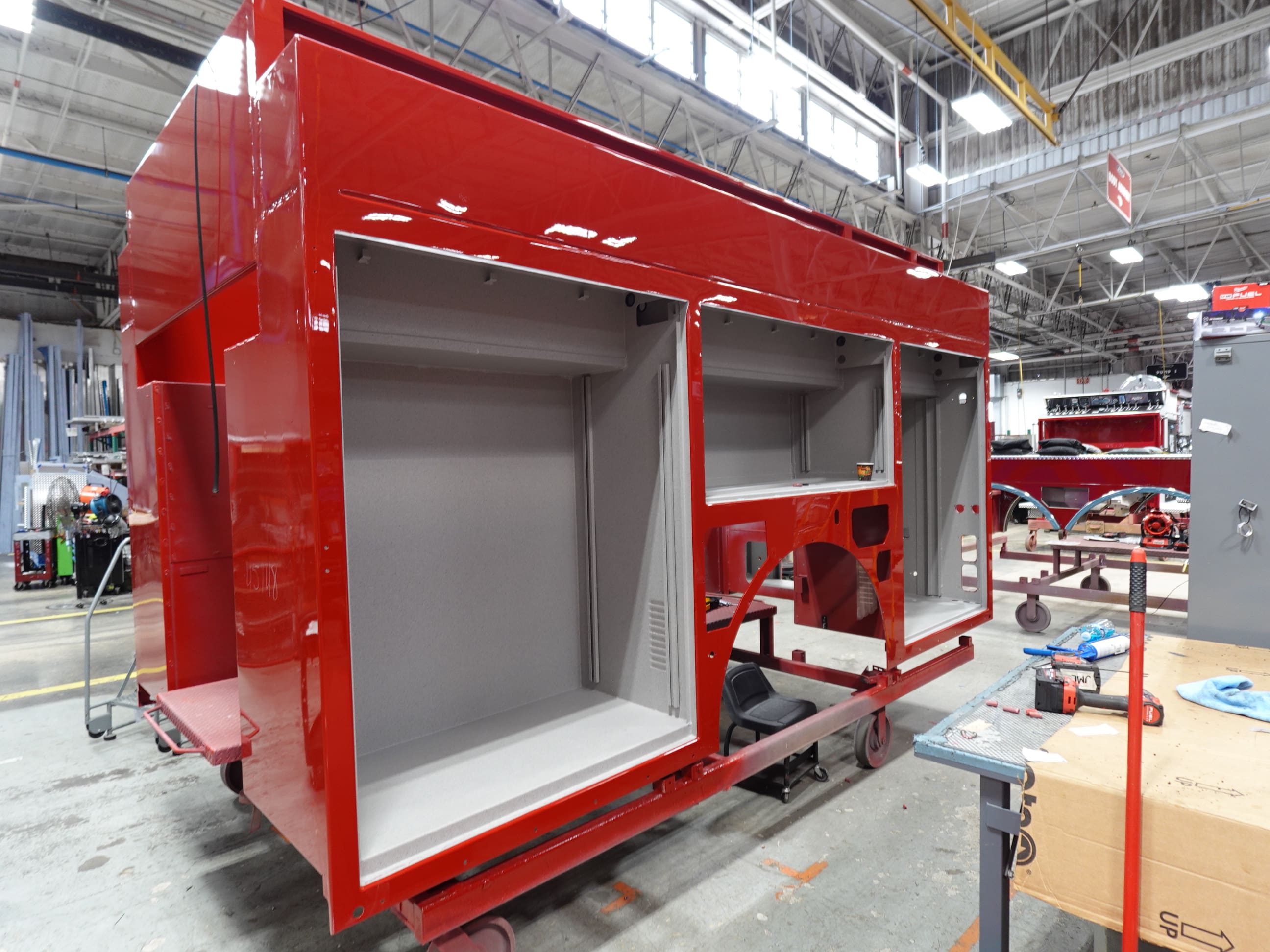

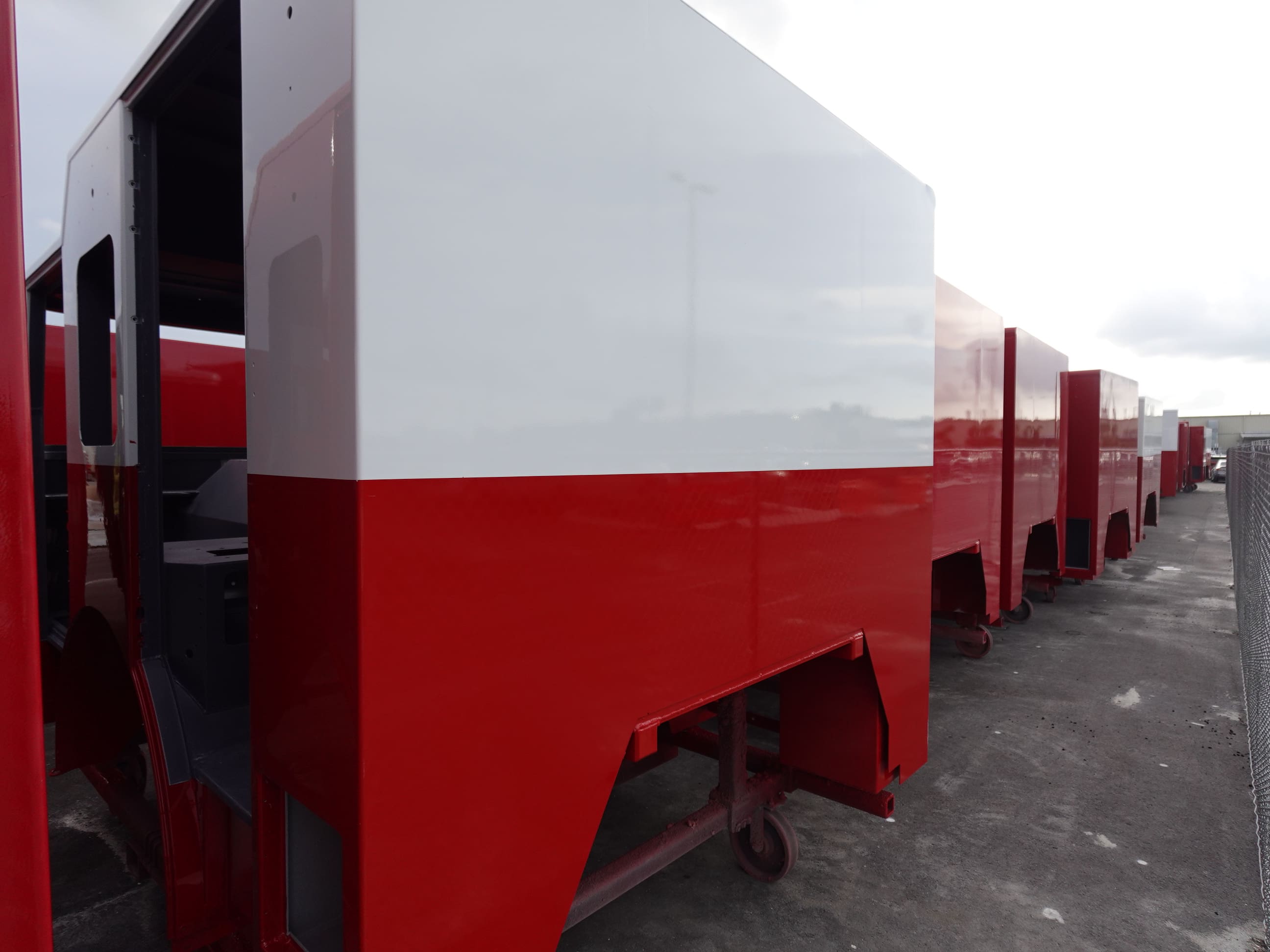

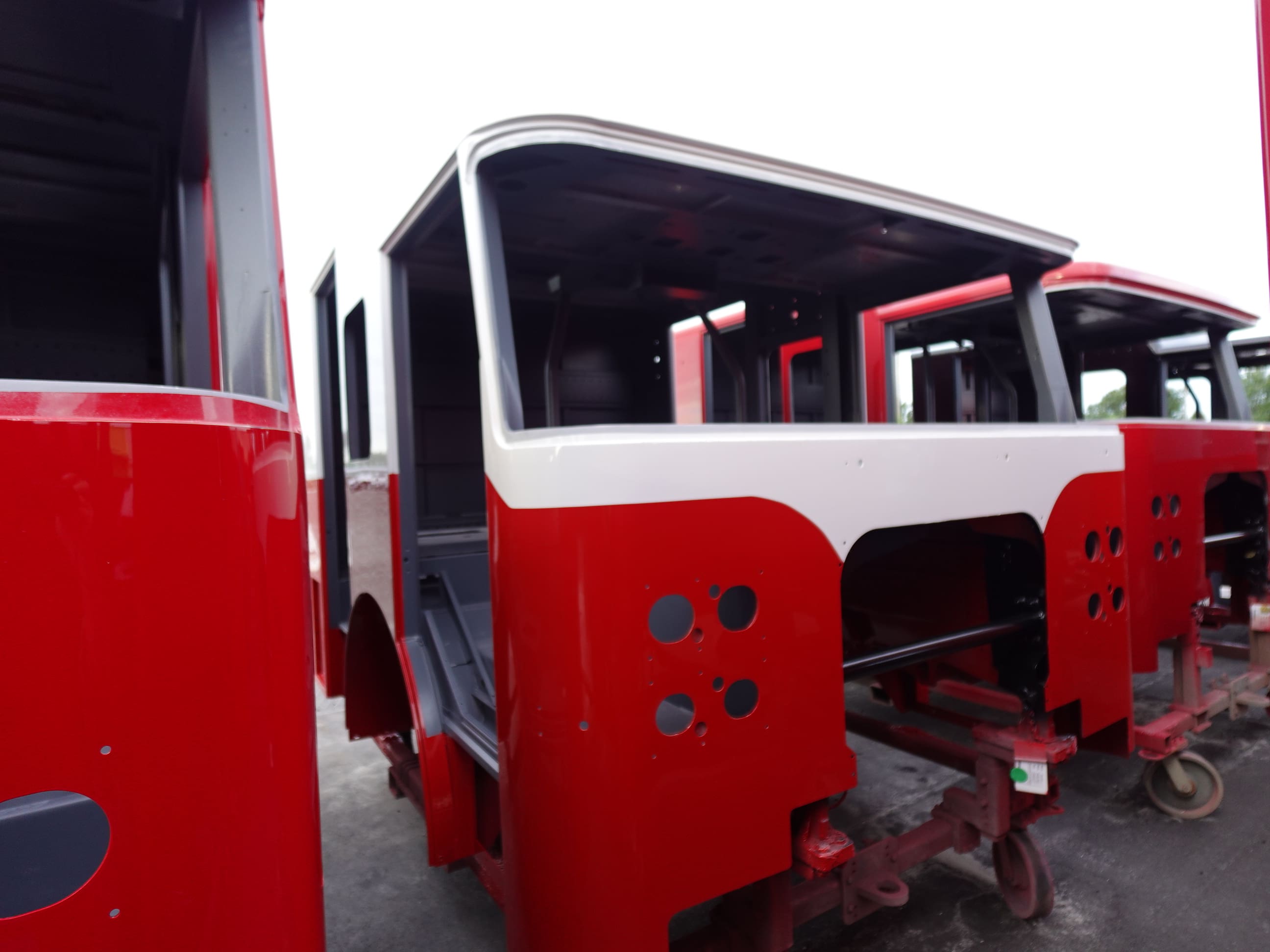

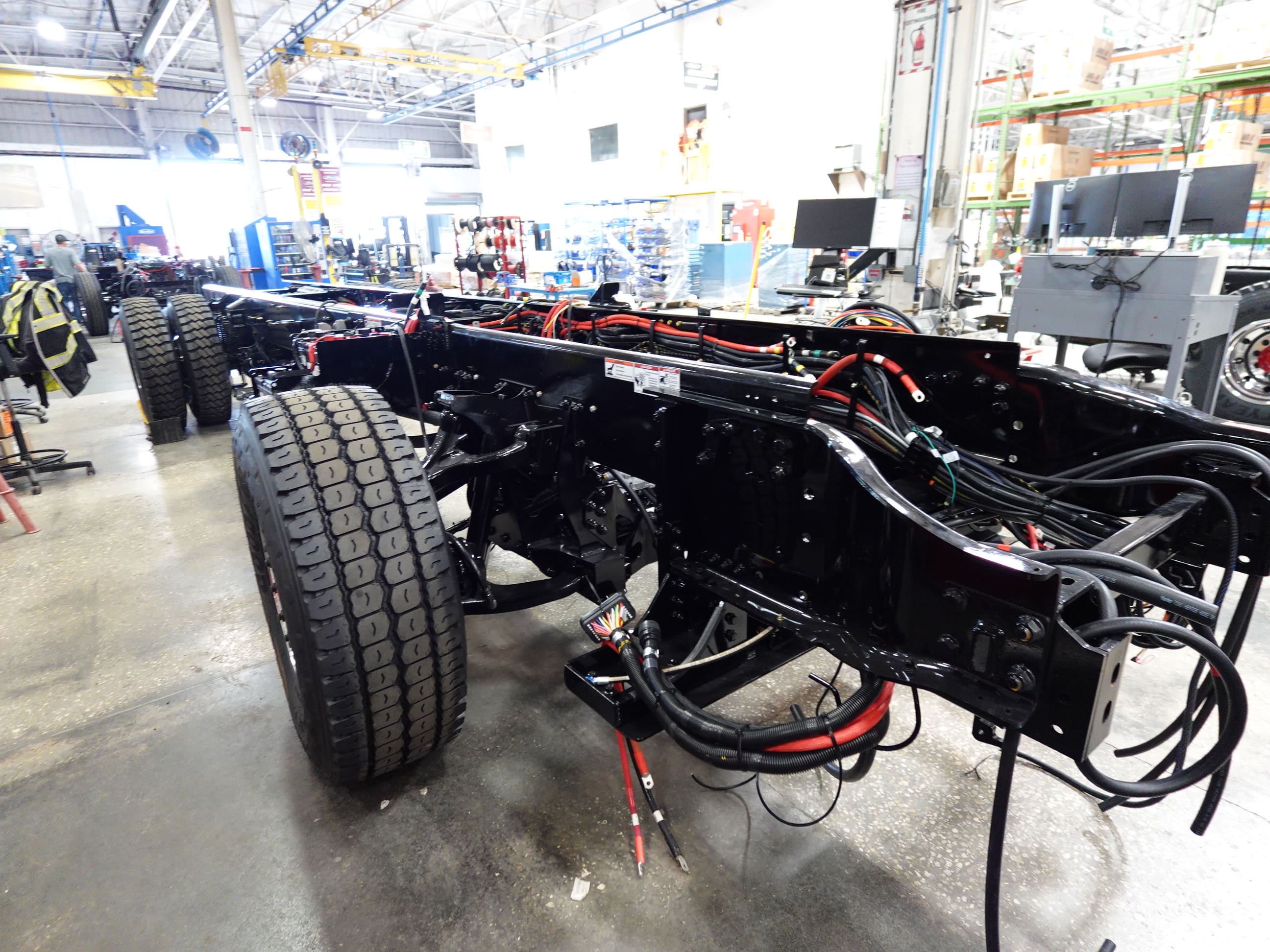

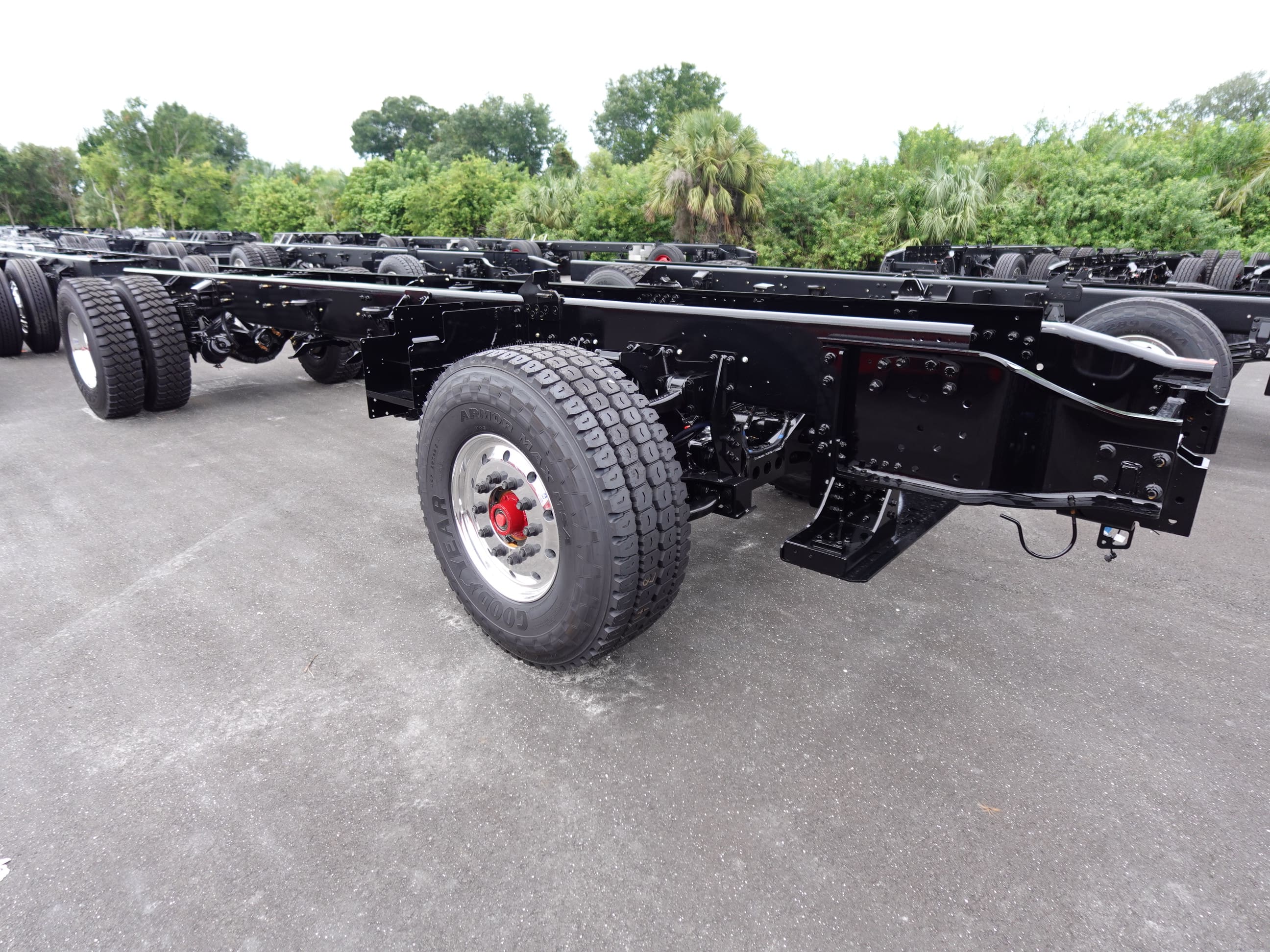

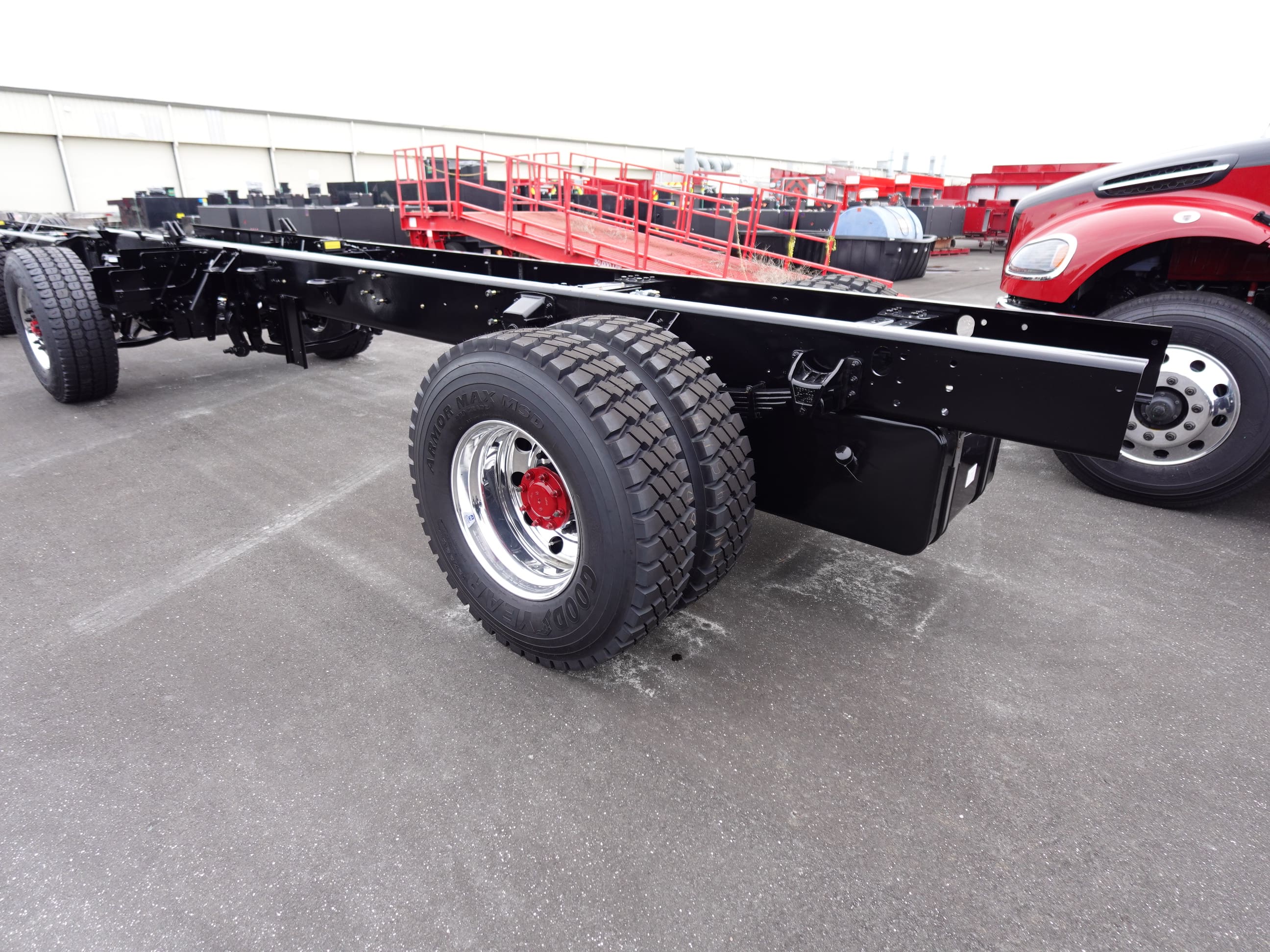

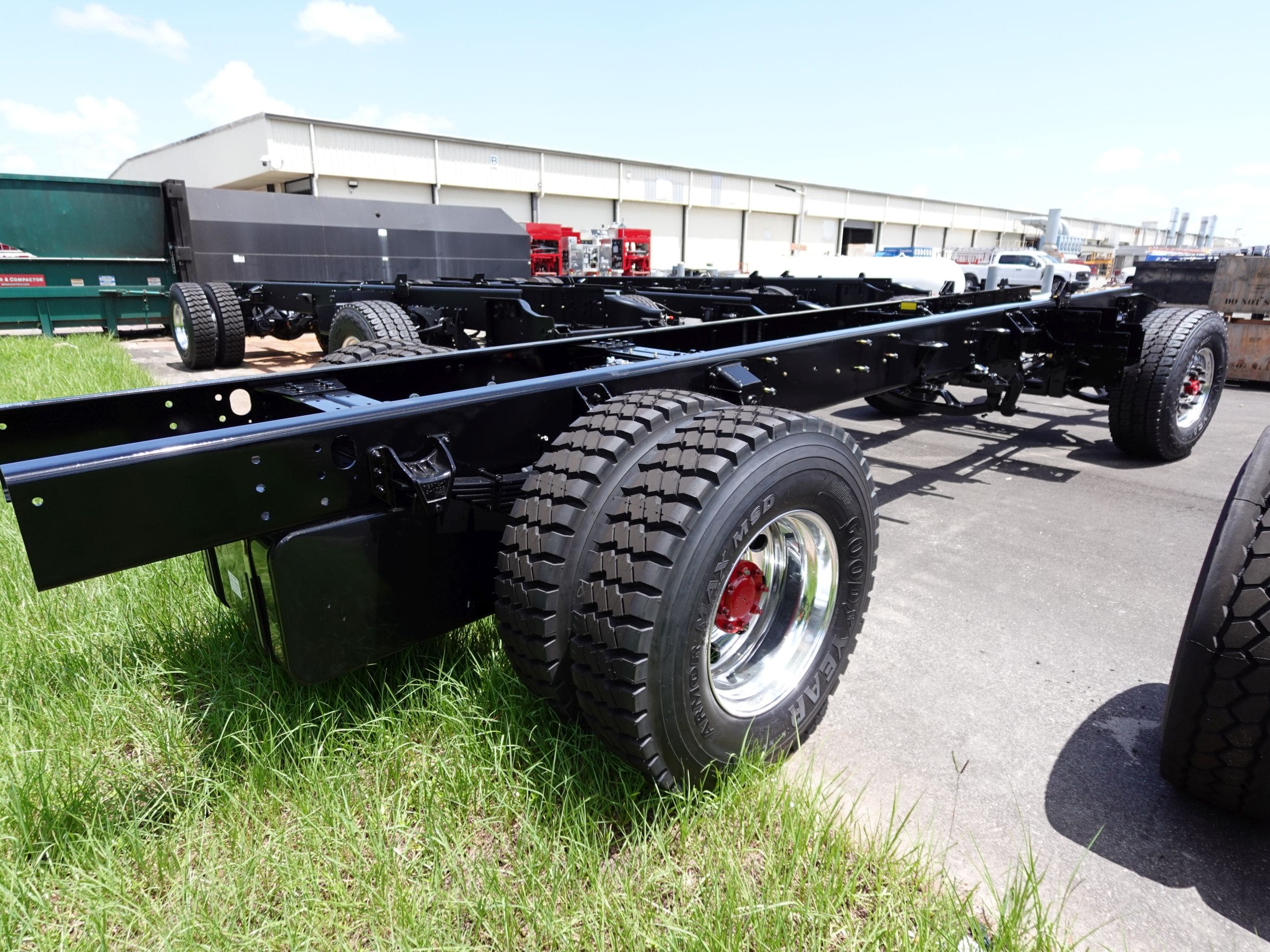

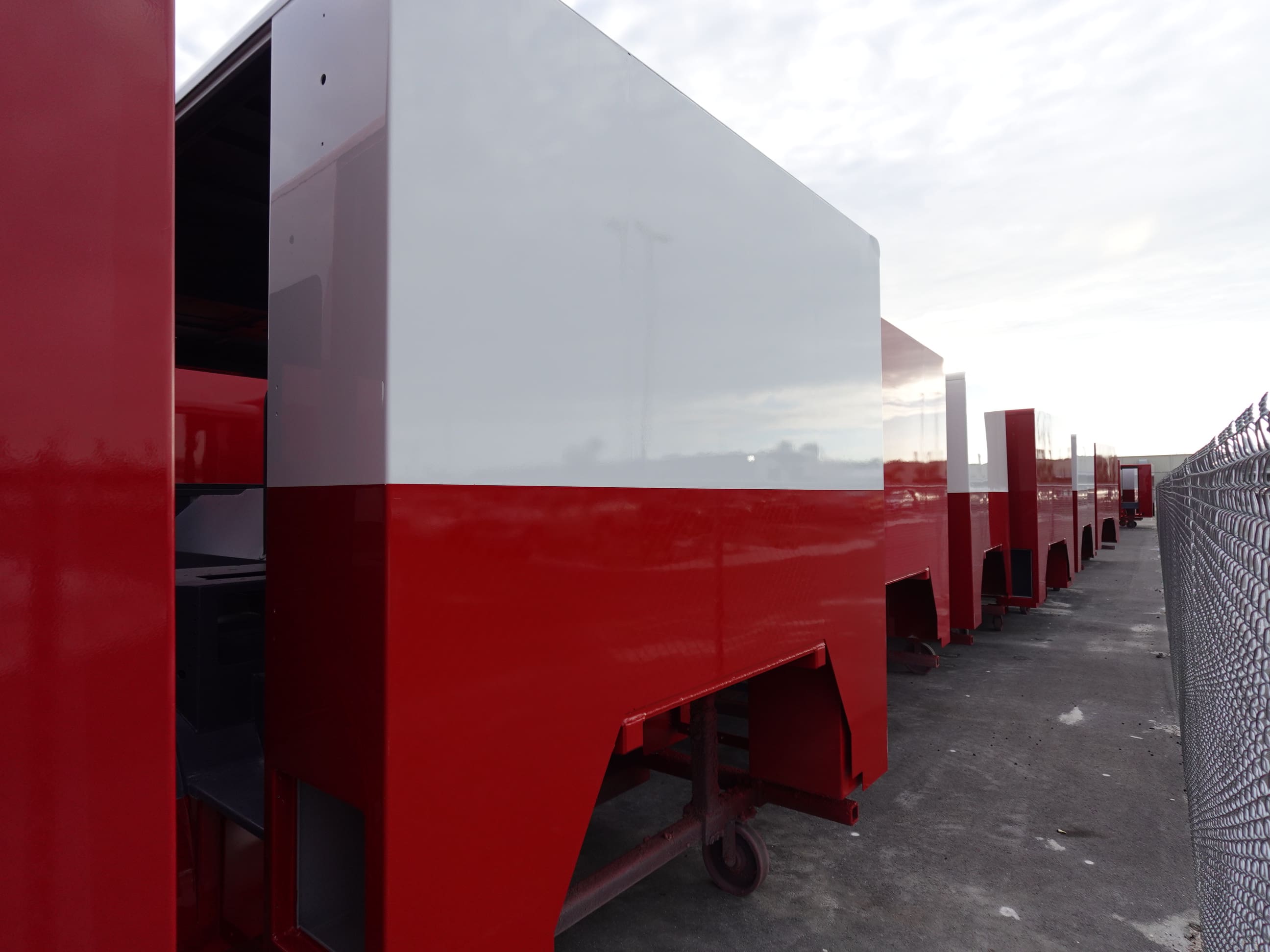

In this report your cab completed paint, the frame build

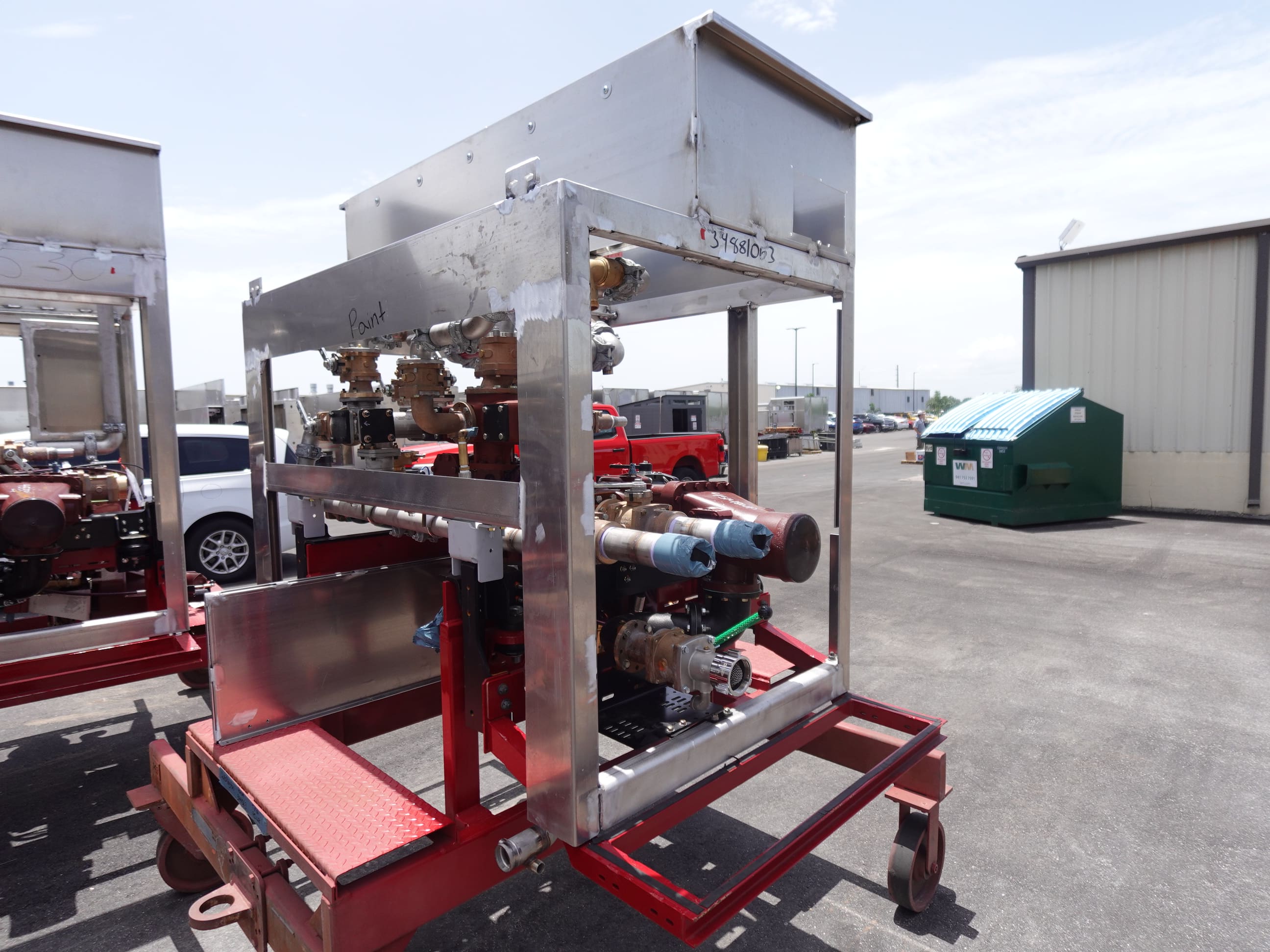

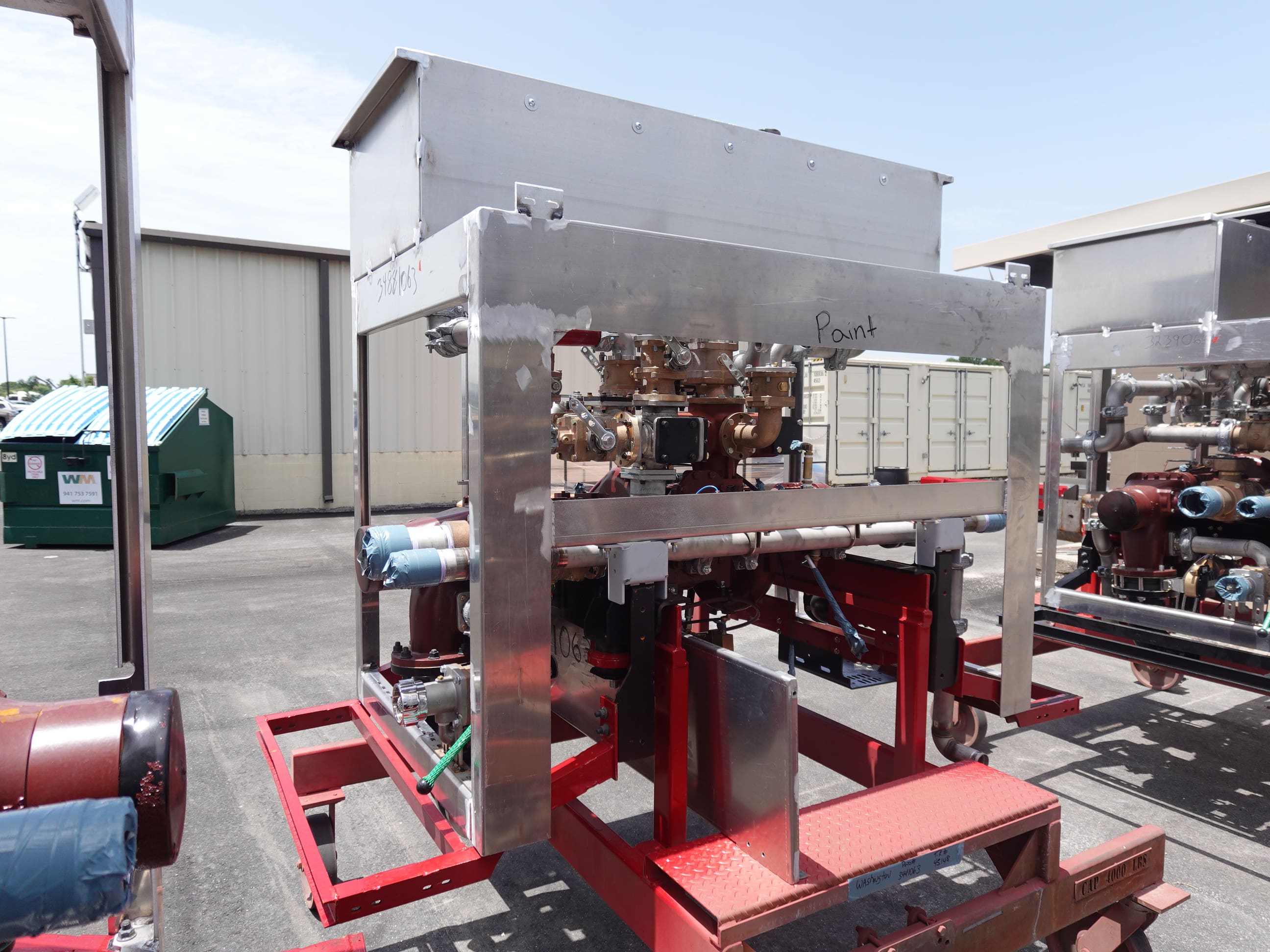

began, the pump house was painted then staged to

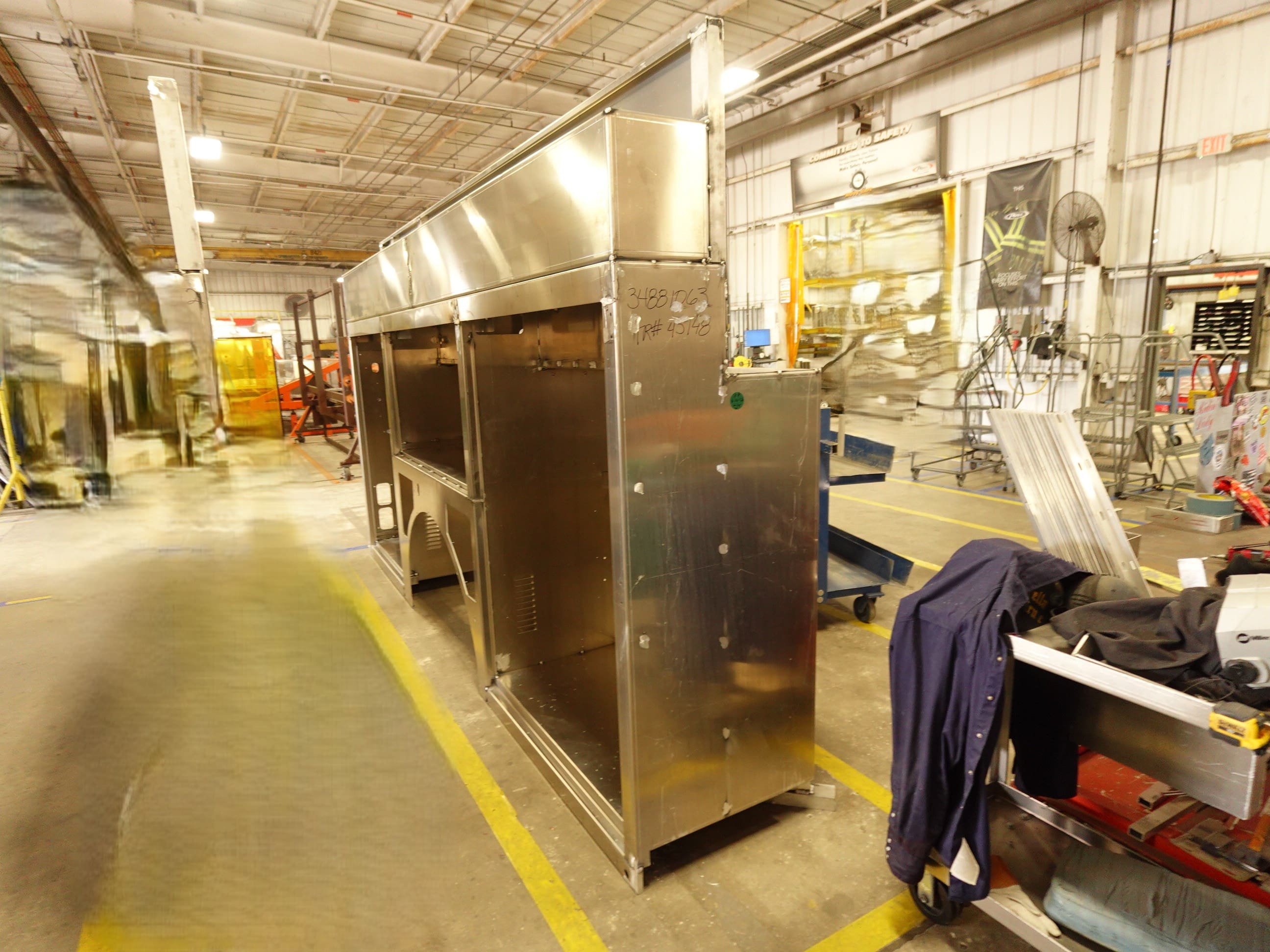

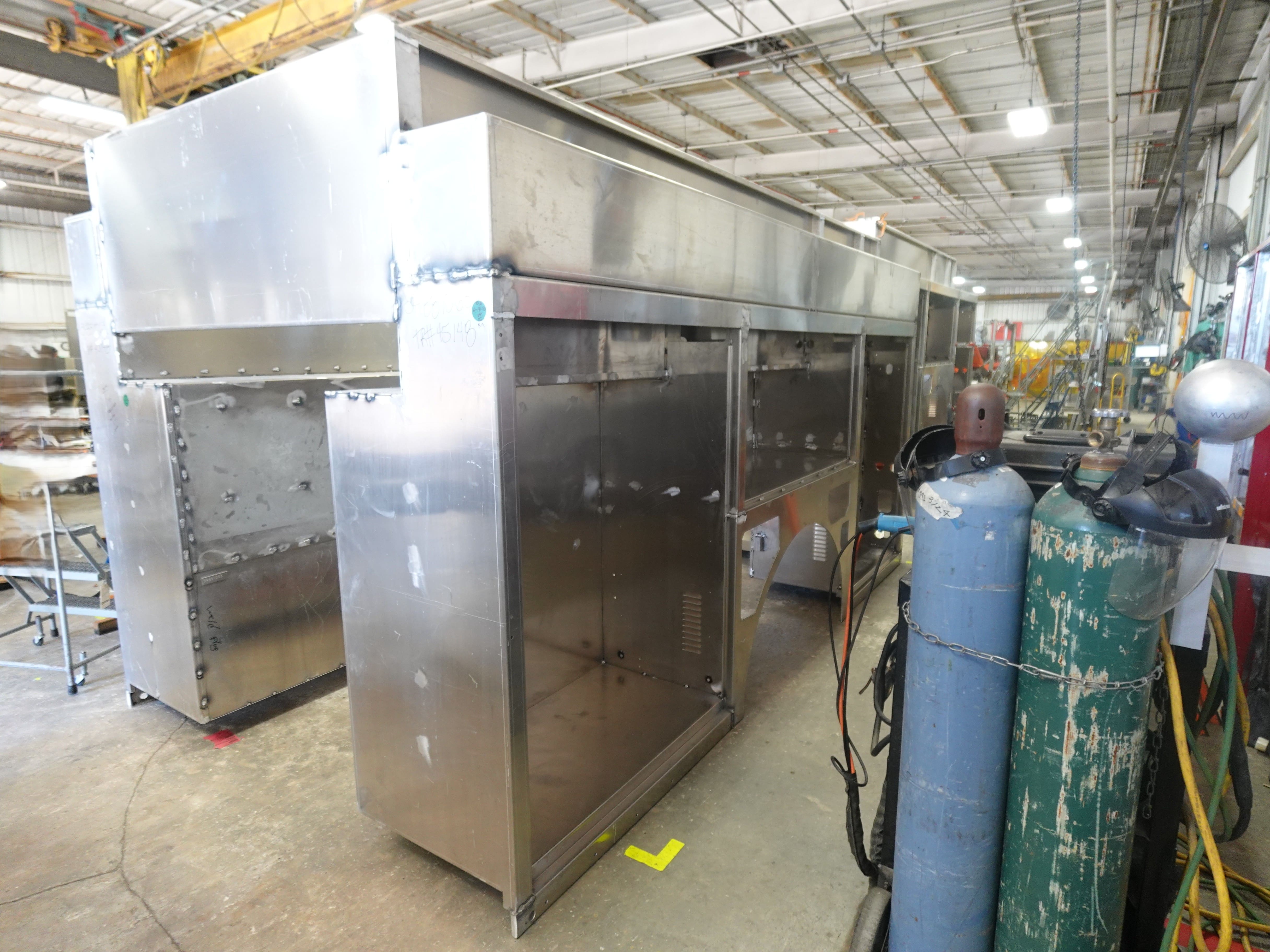

continue initial assembly, and the body remained
staged.
07-24-26

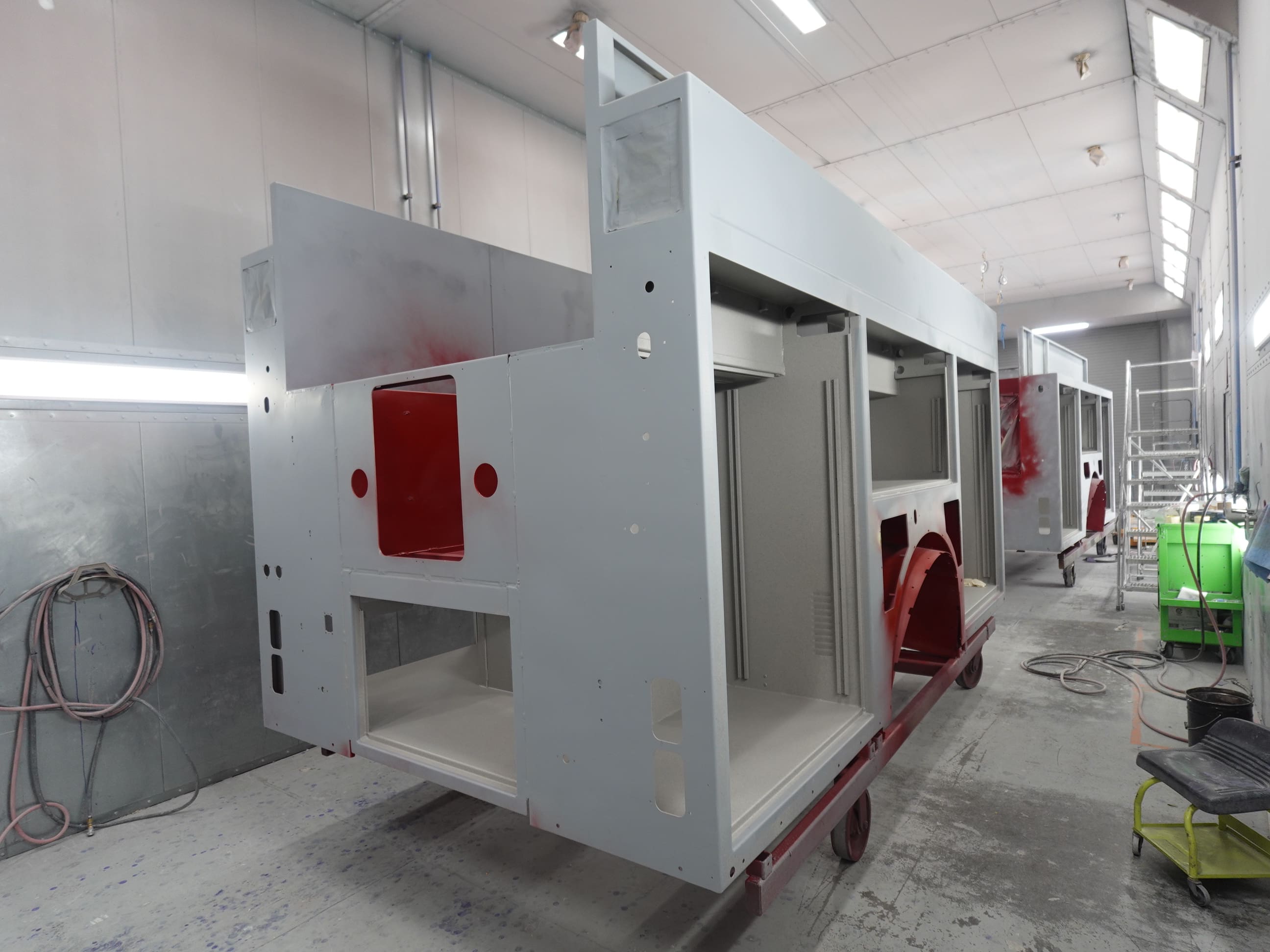

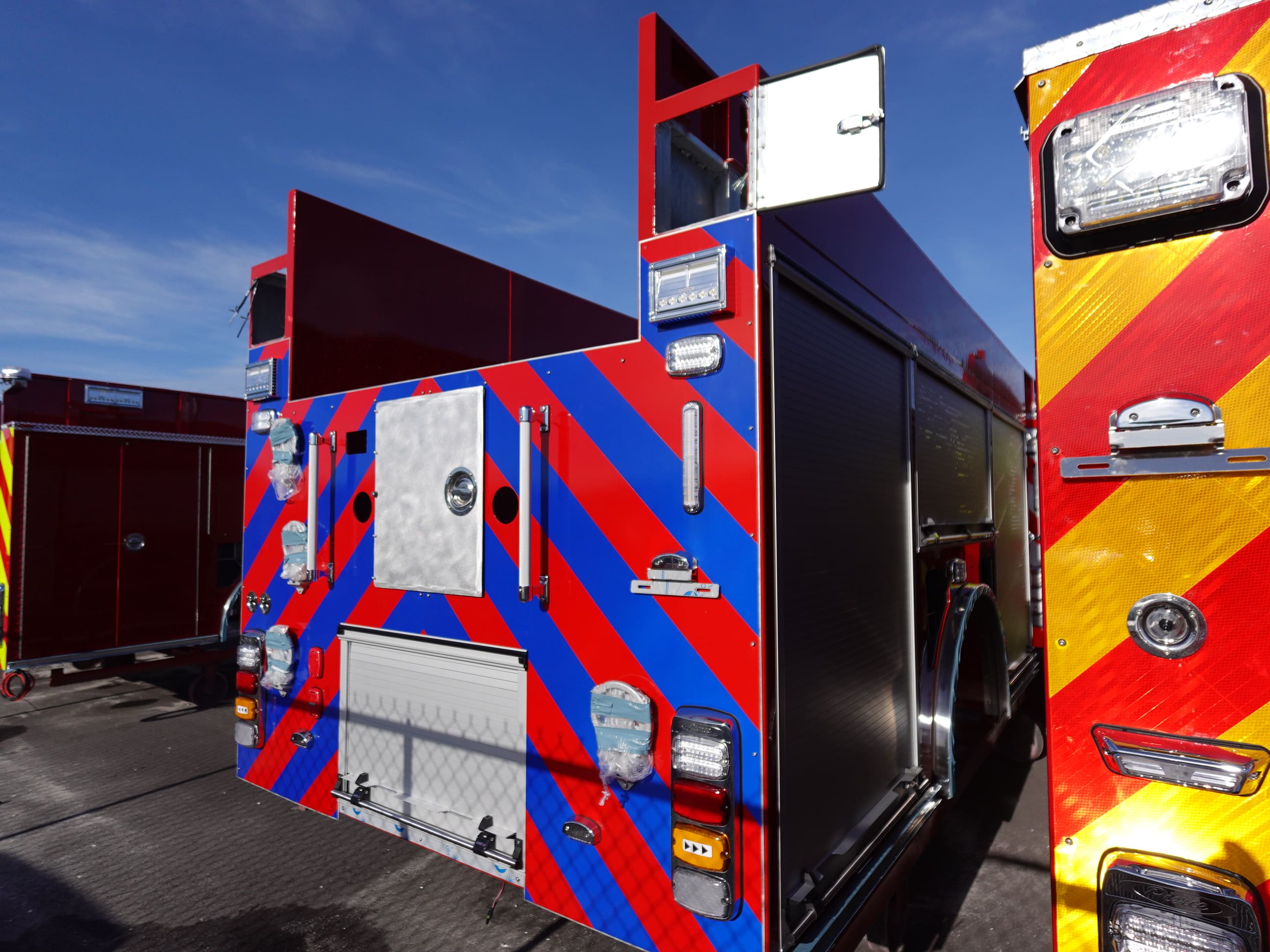

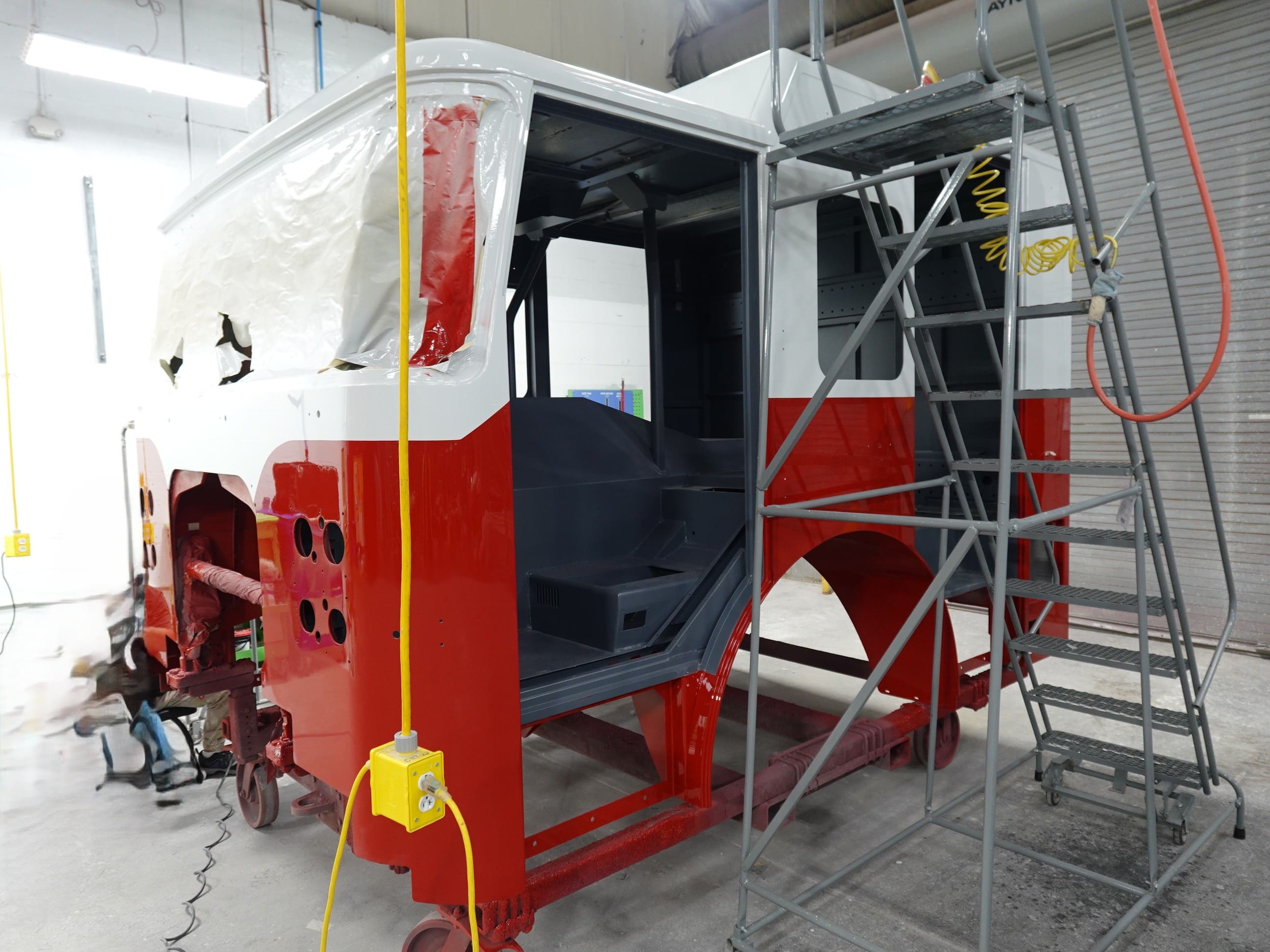

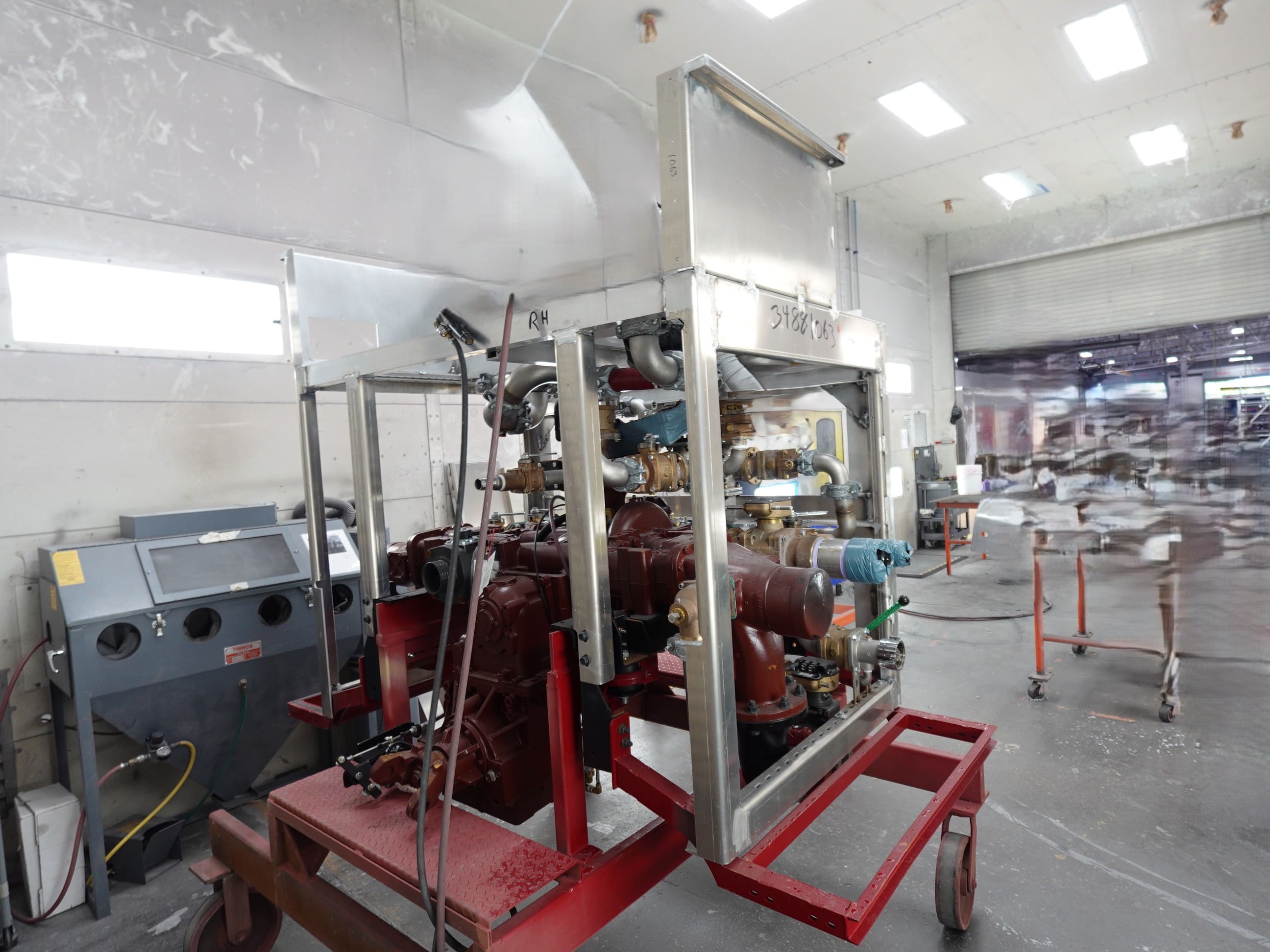

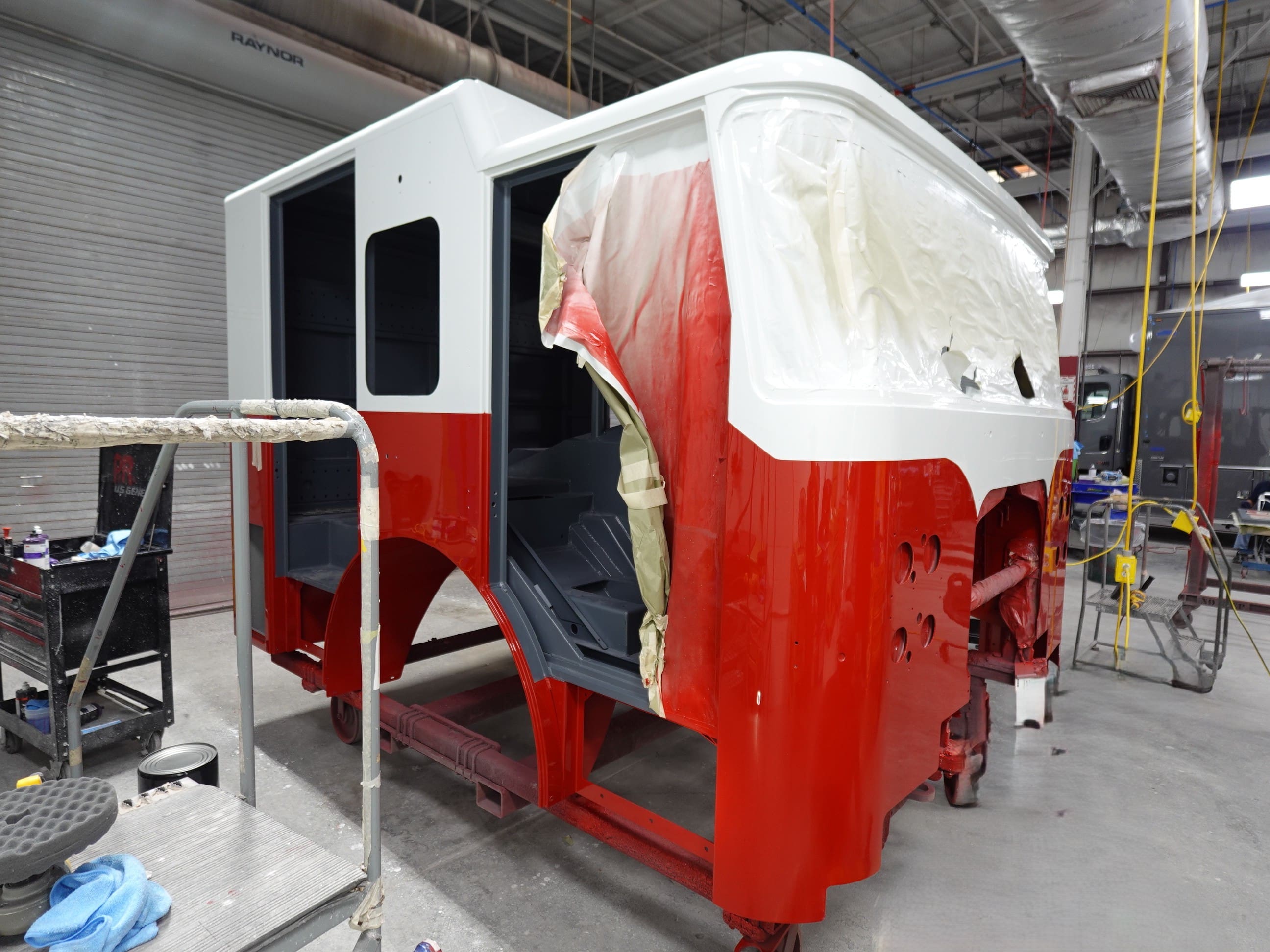

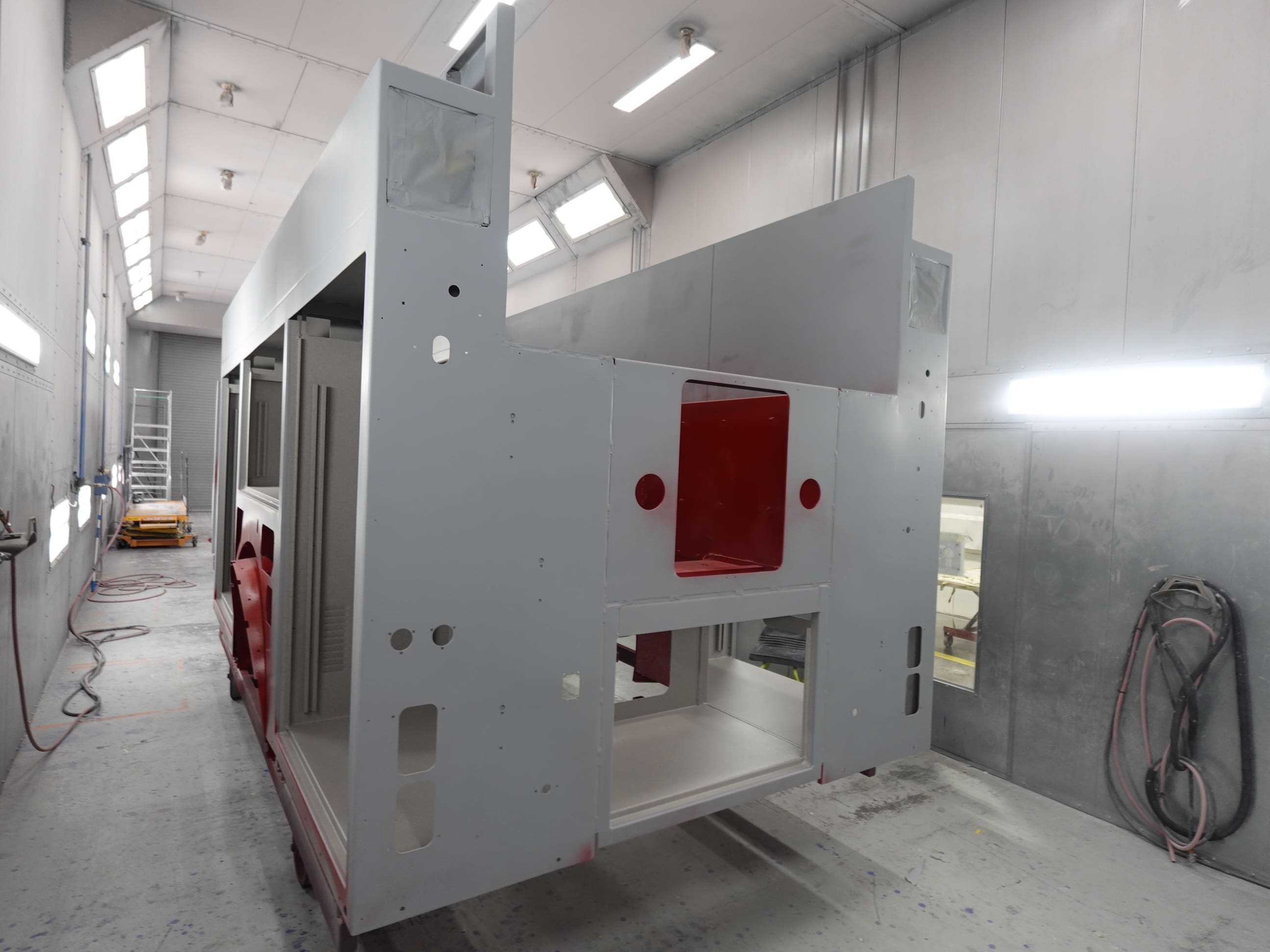

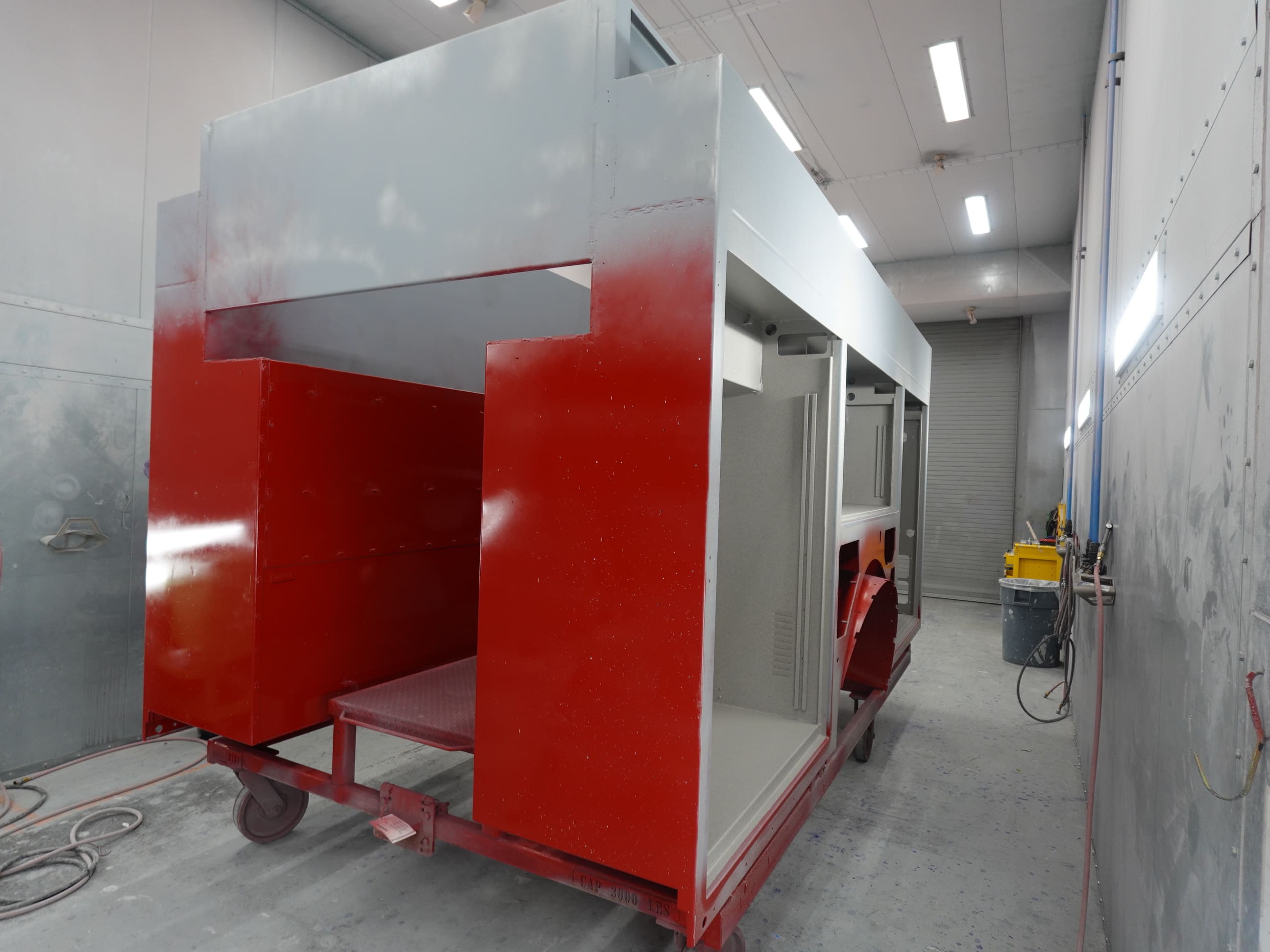

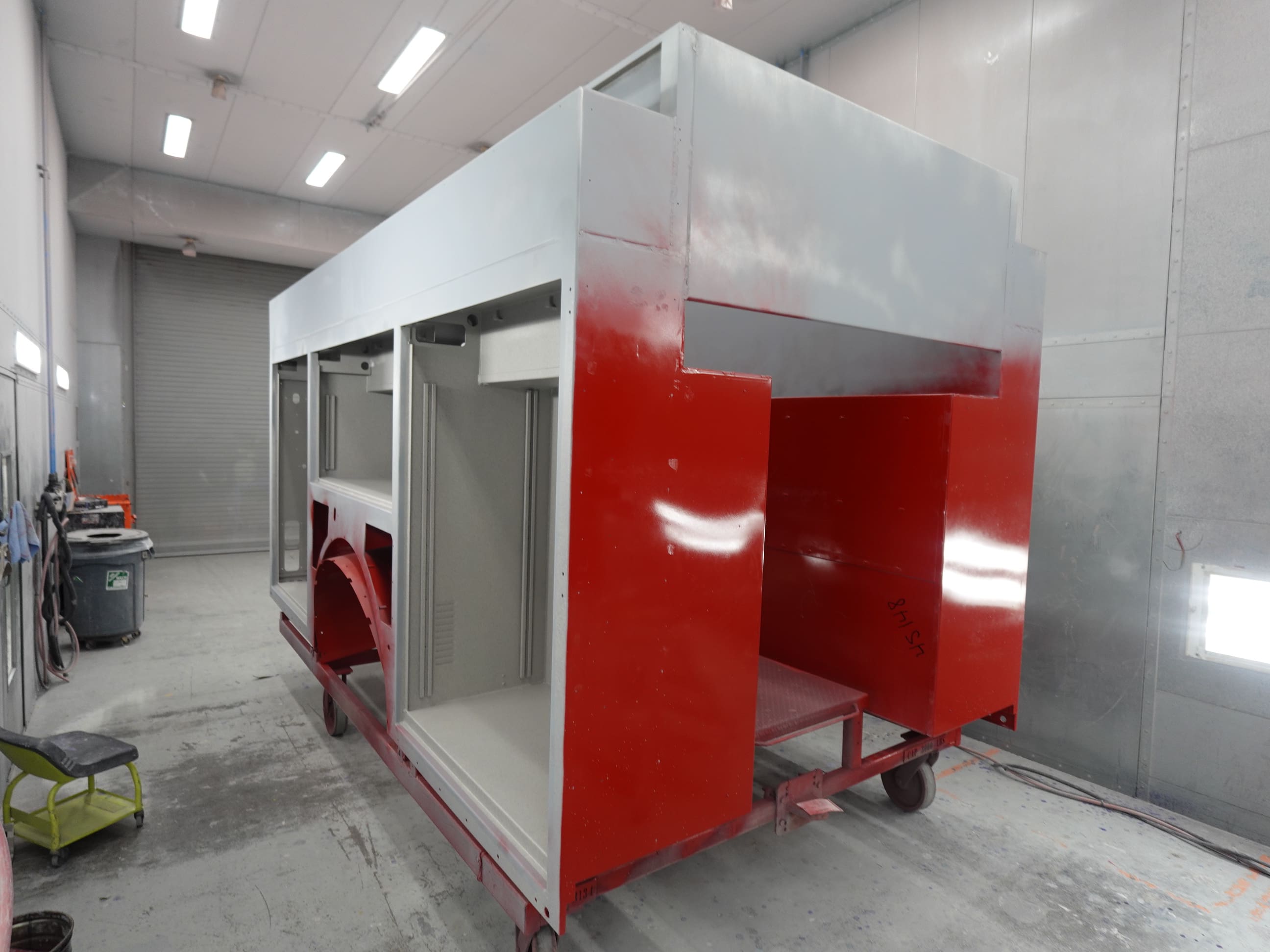

In this report, the cab began the paint process, the
pump house began in paint, and the body completed

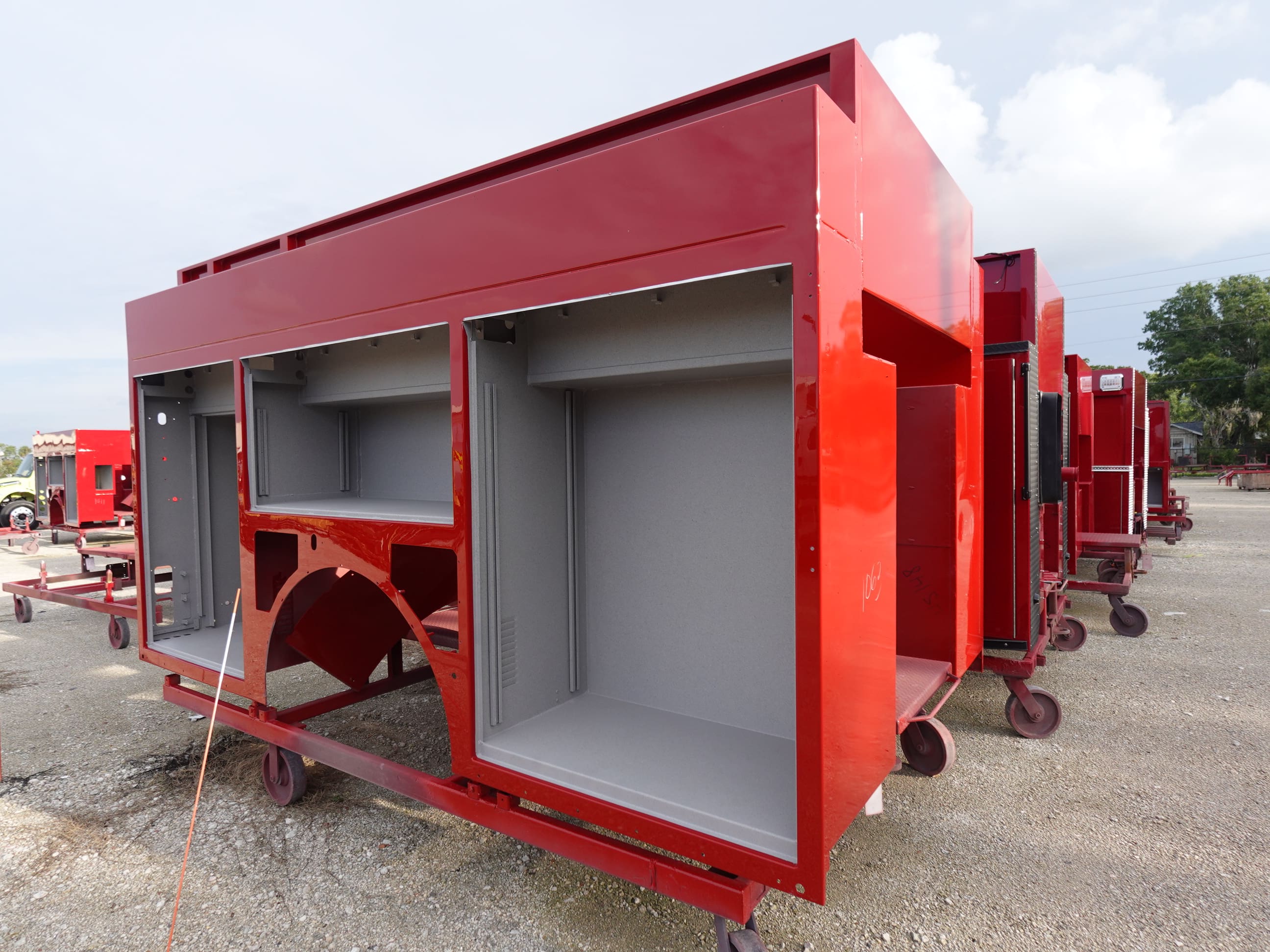

the paint process.
07-17-26

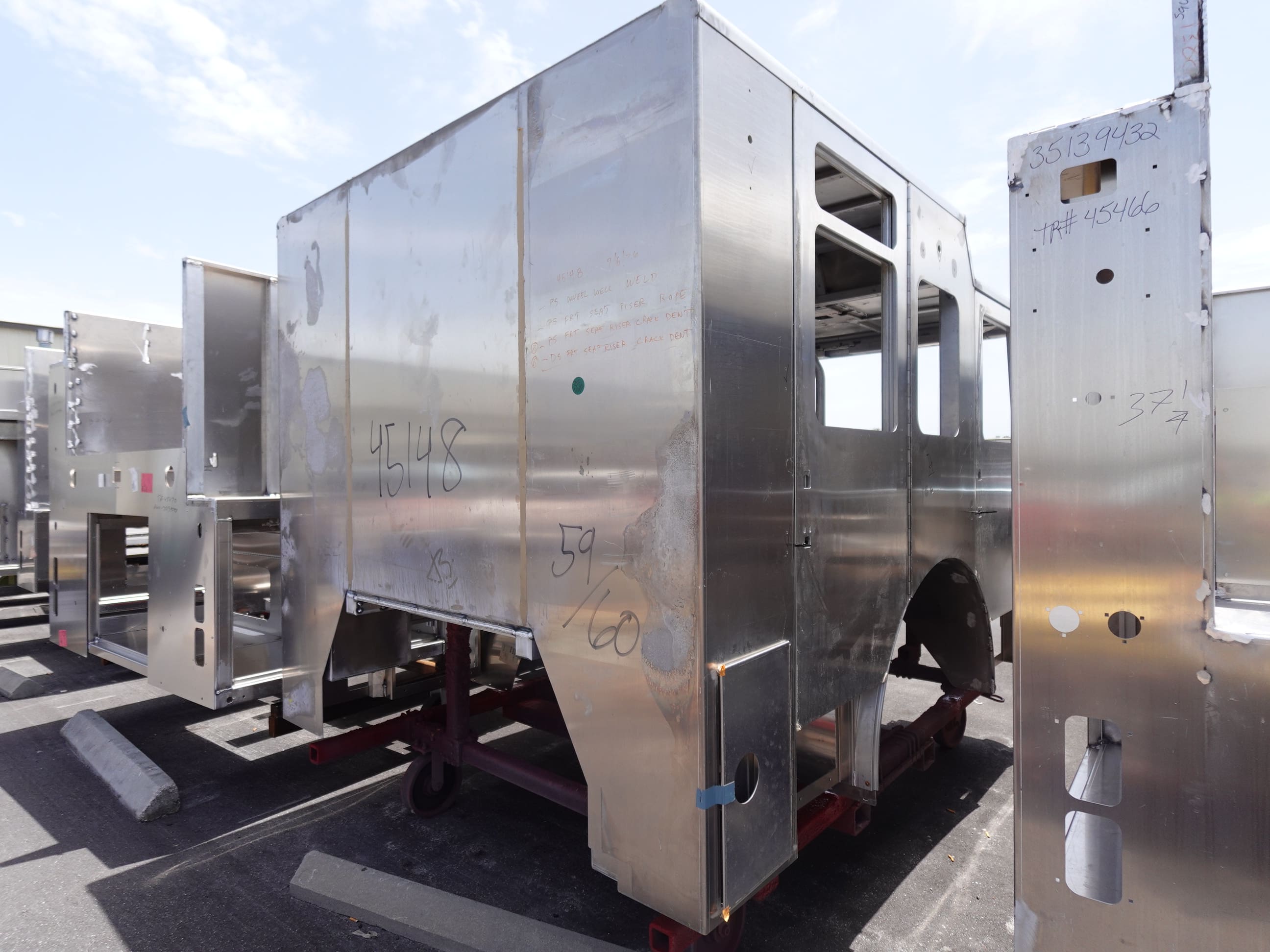

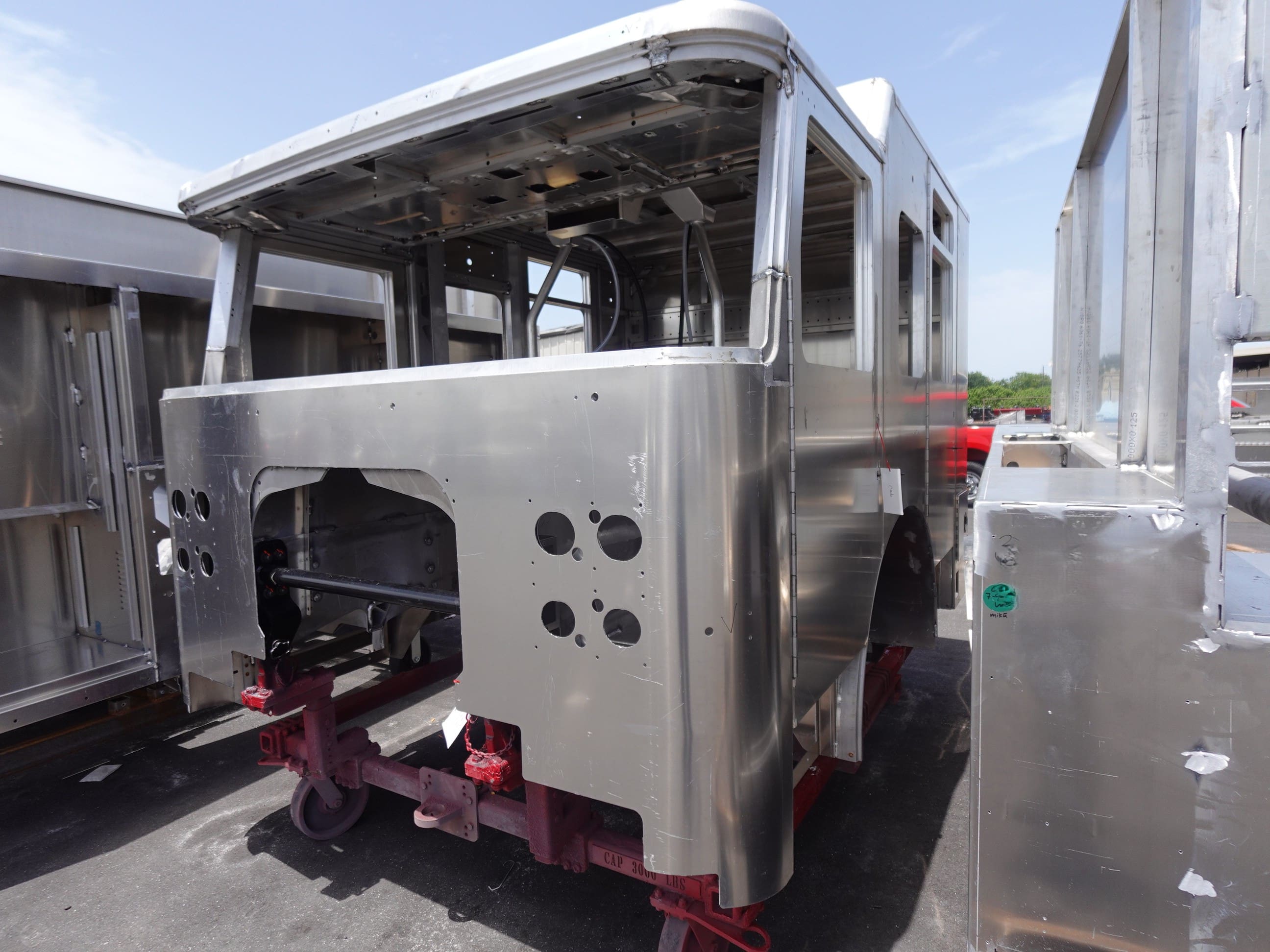

In this report, the cab completed fabrication, the pump house continued initial assembly, and the body began the paint process.

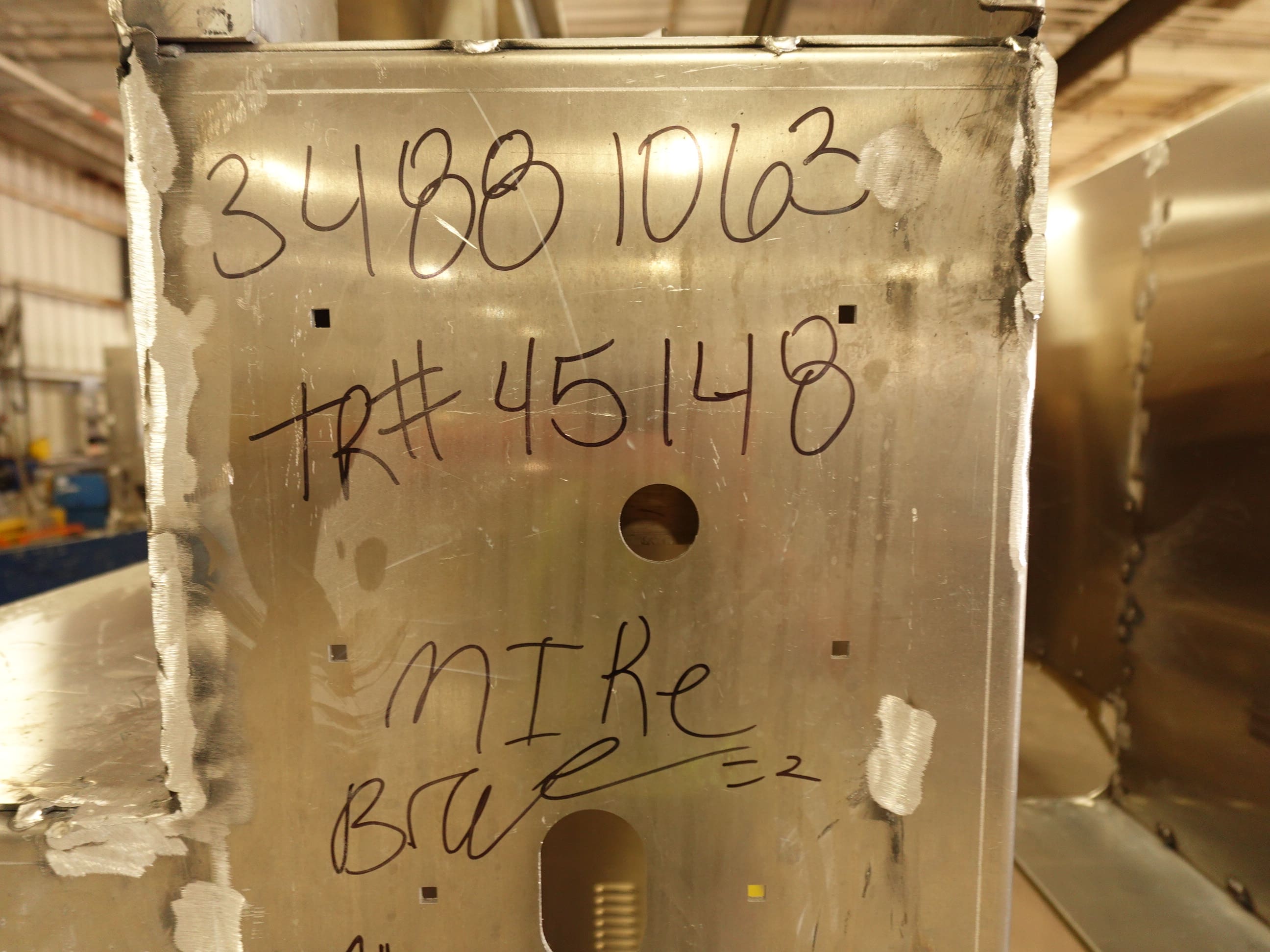

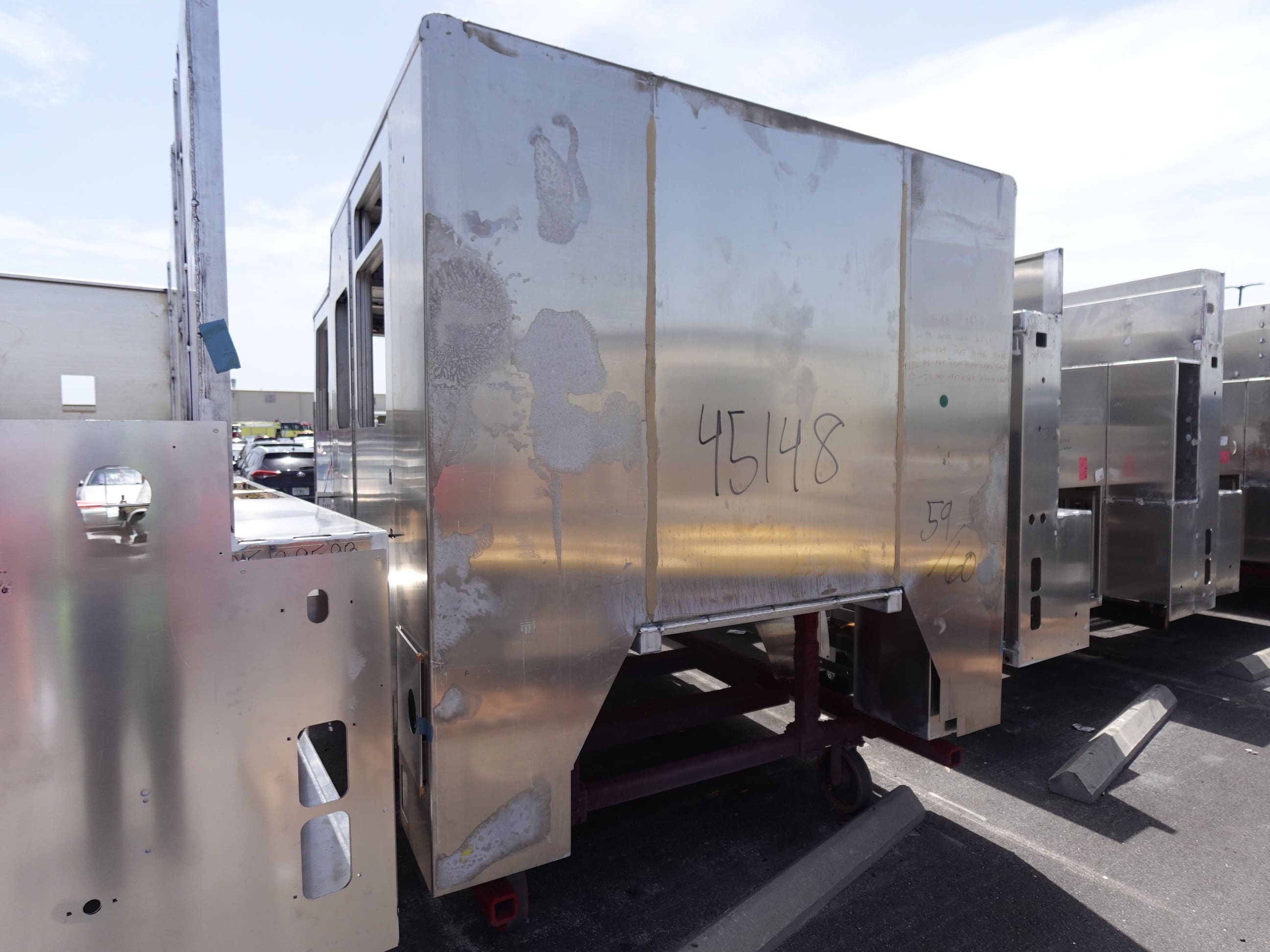

06-19-26

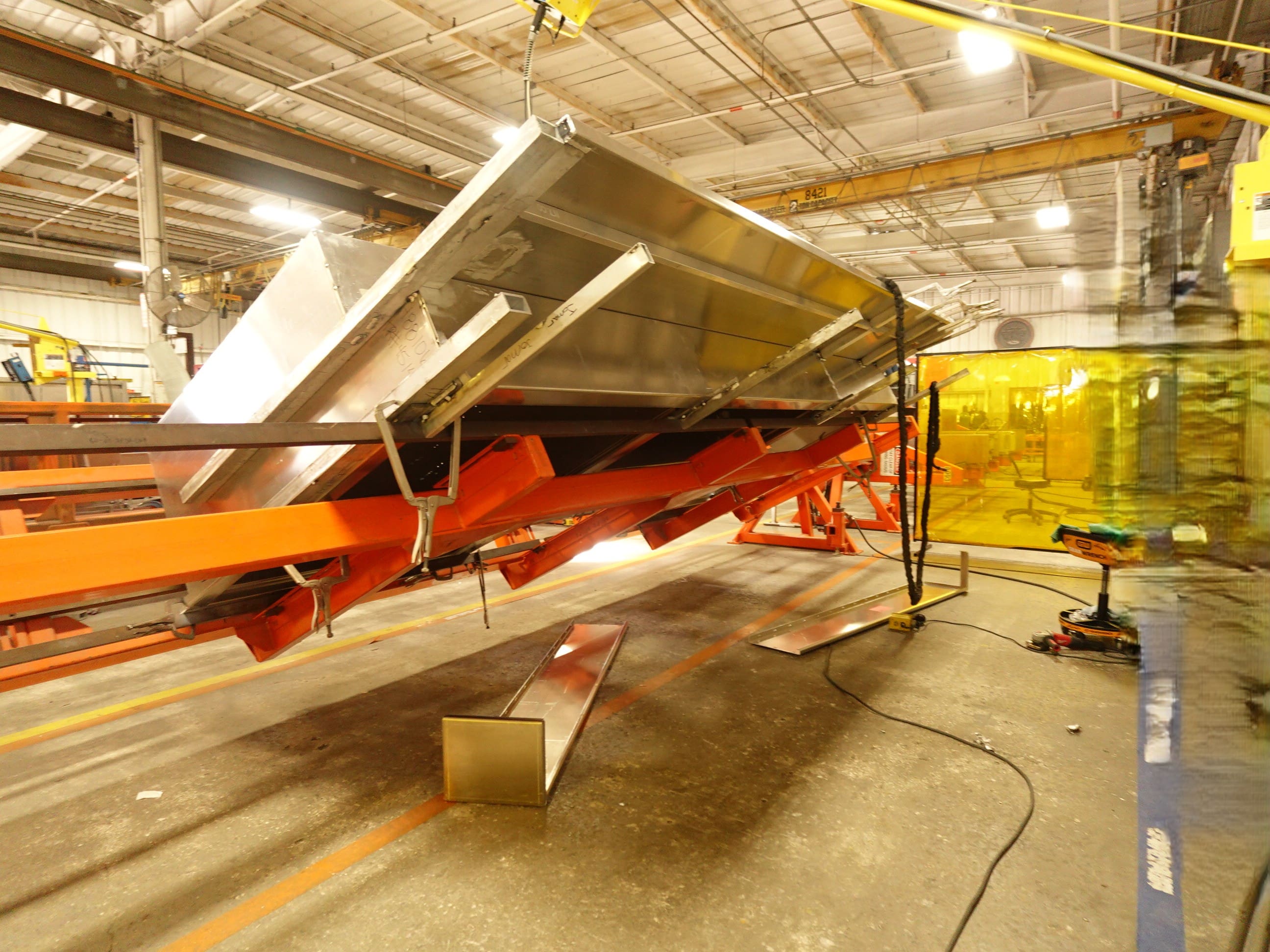

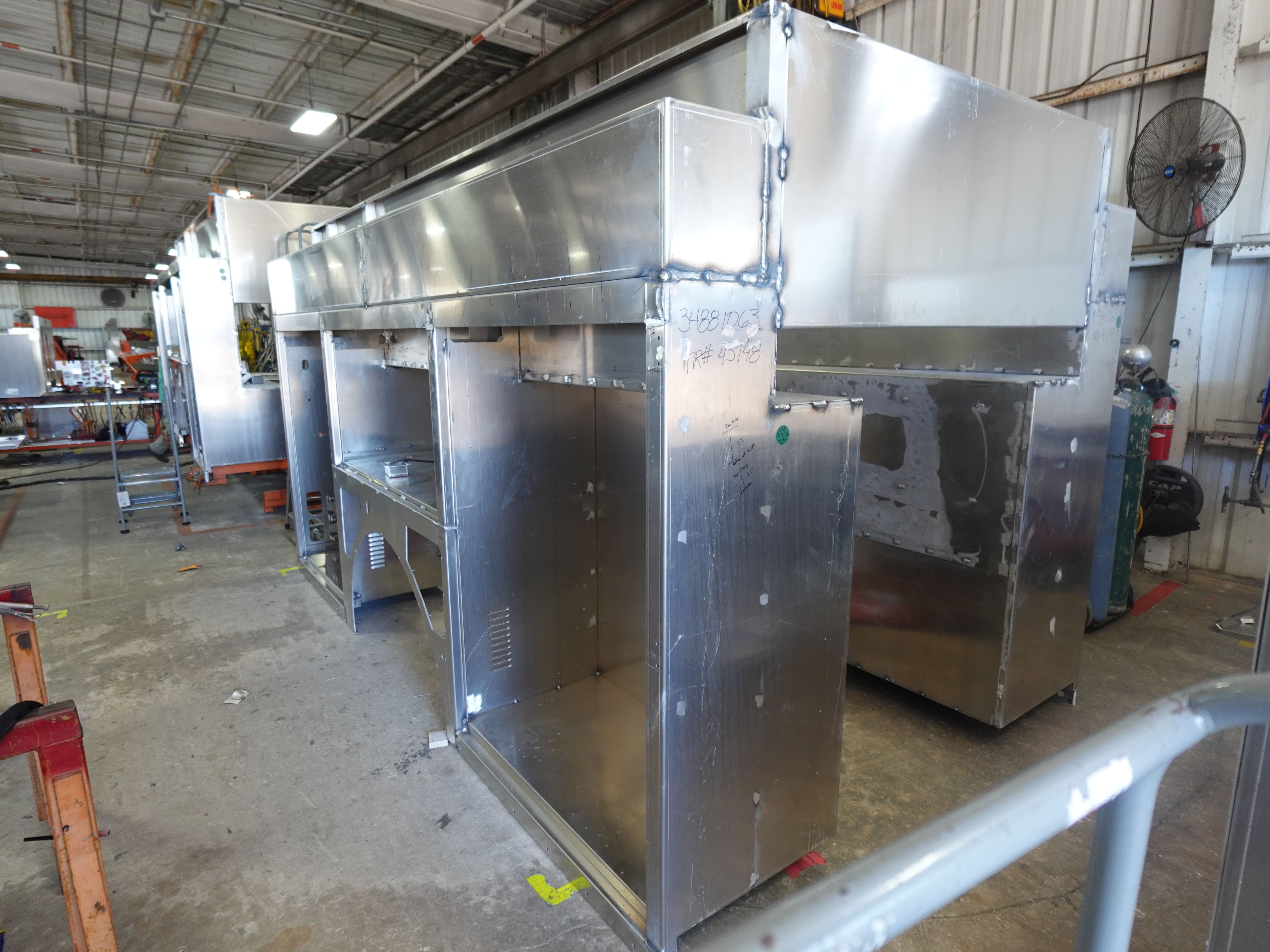

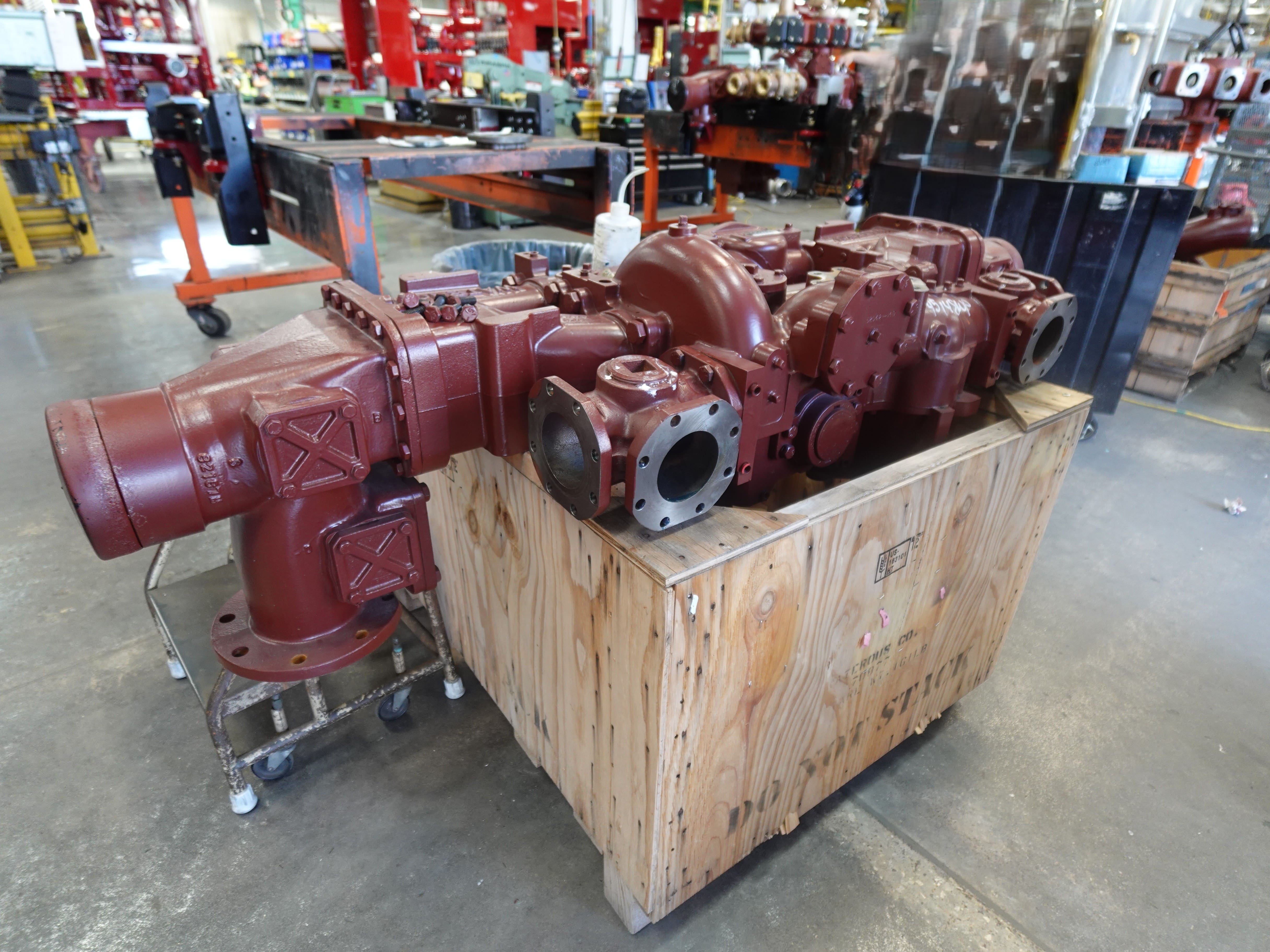

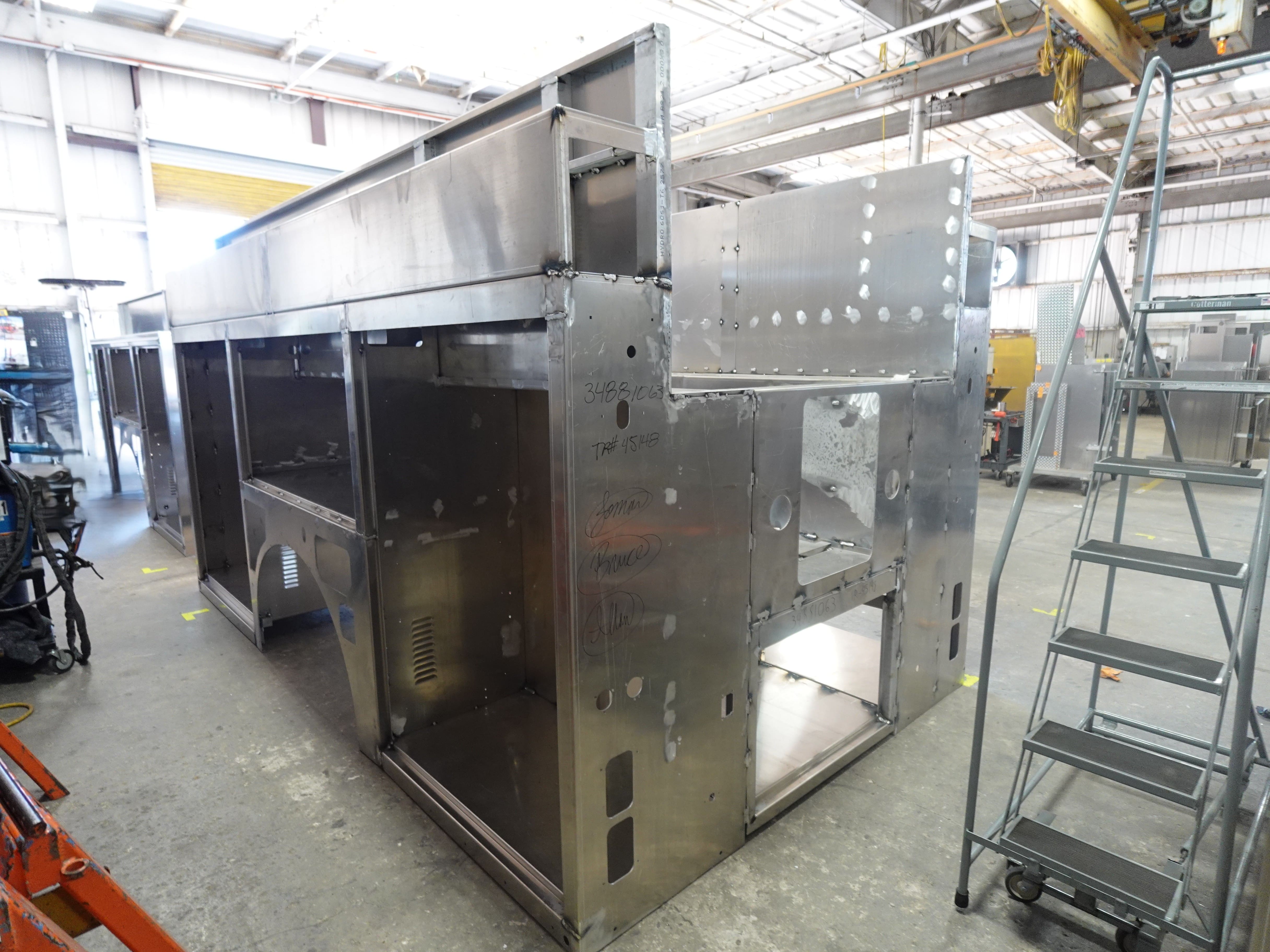

This new Pierce apparatus is now in production. In this report, the body panels began fabrication.
