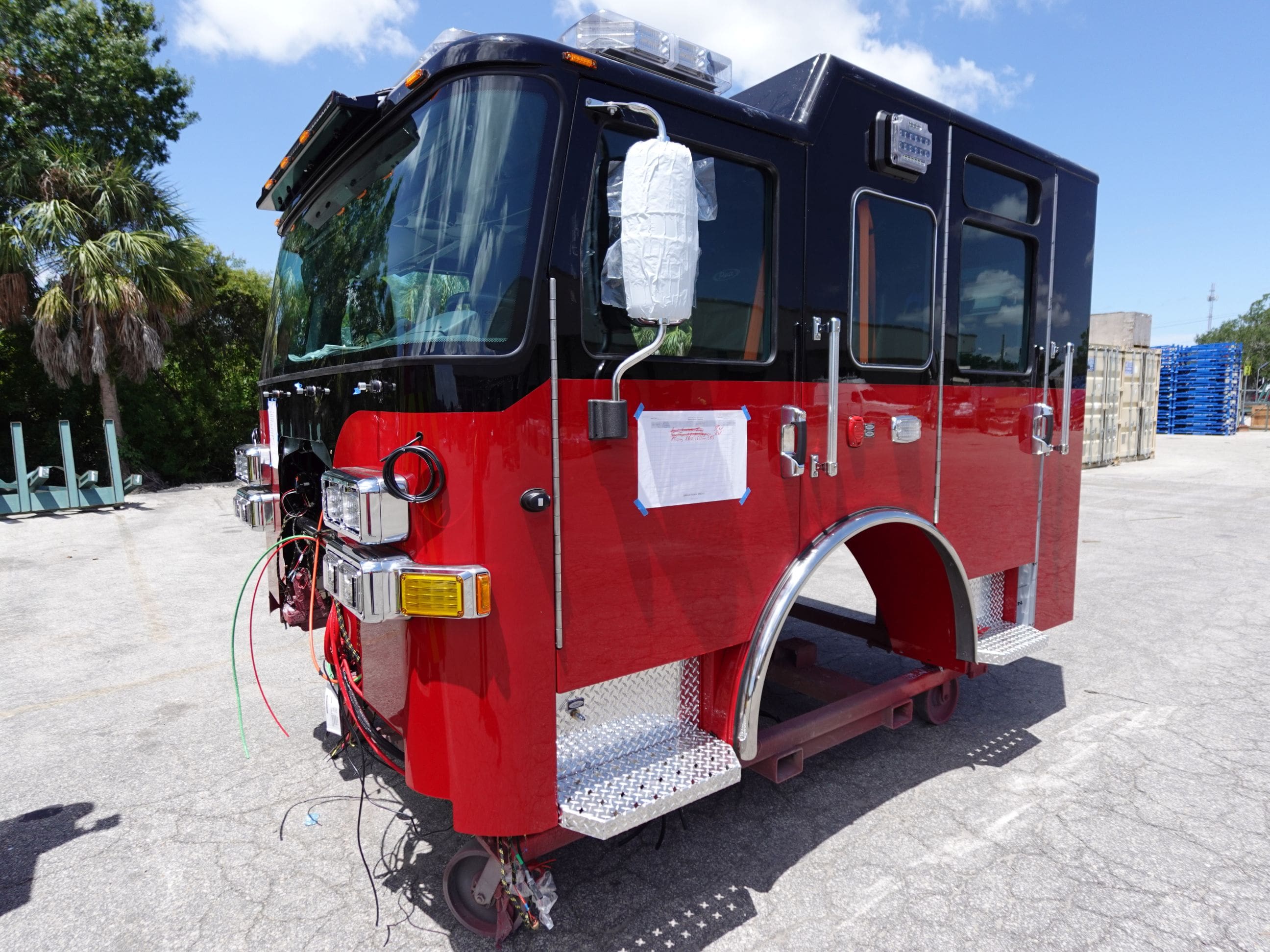

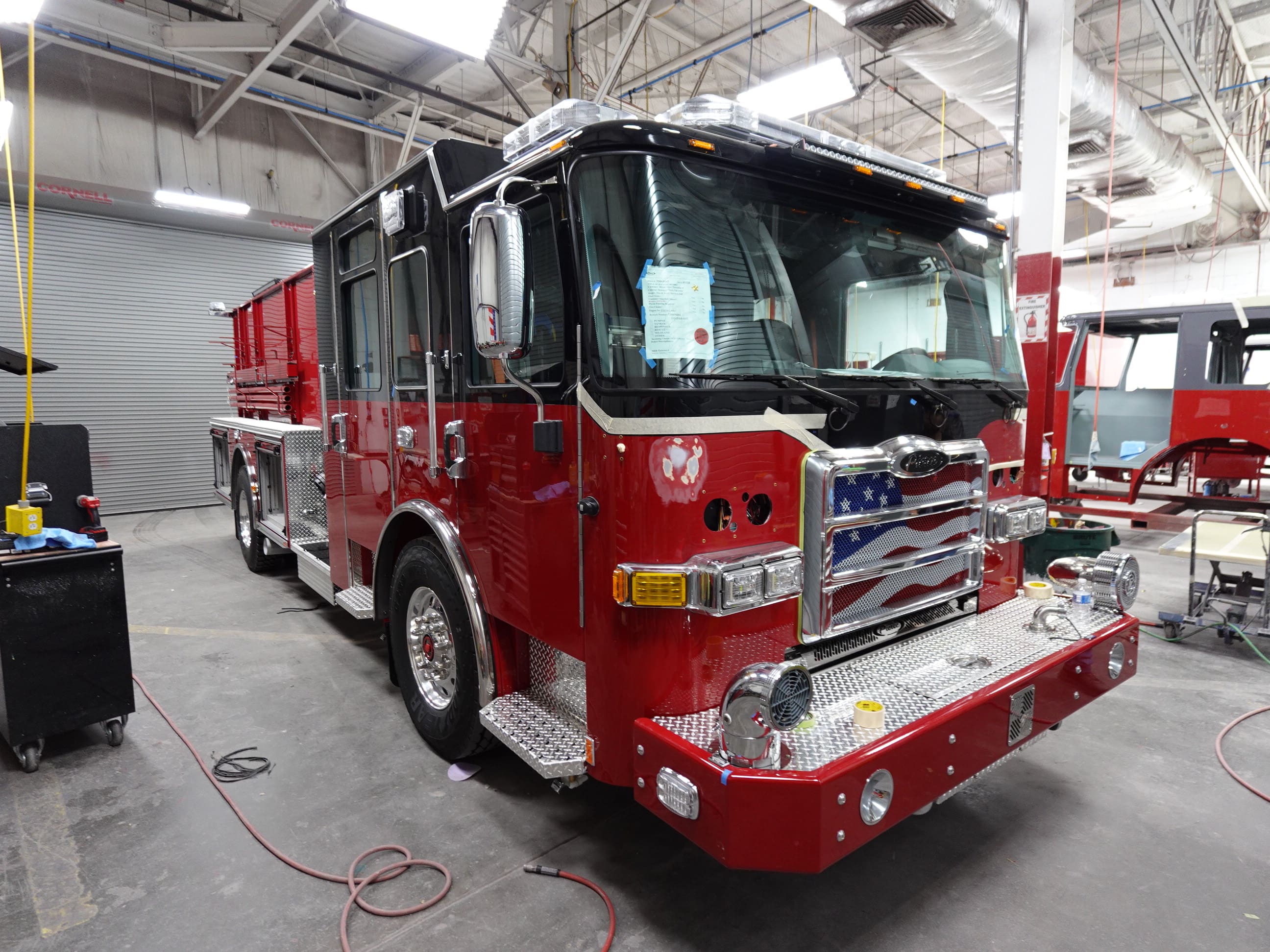

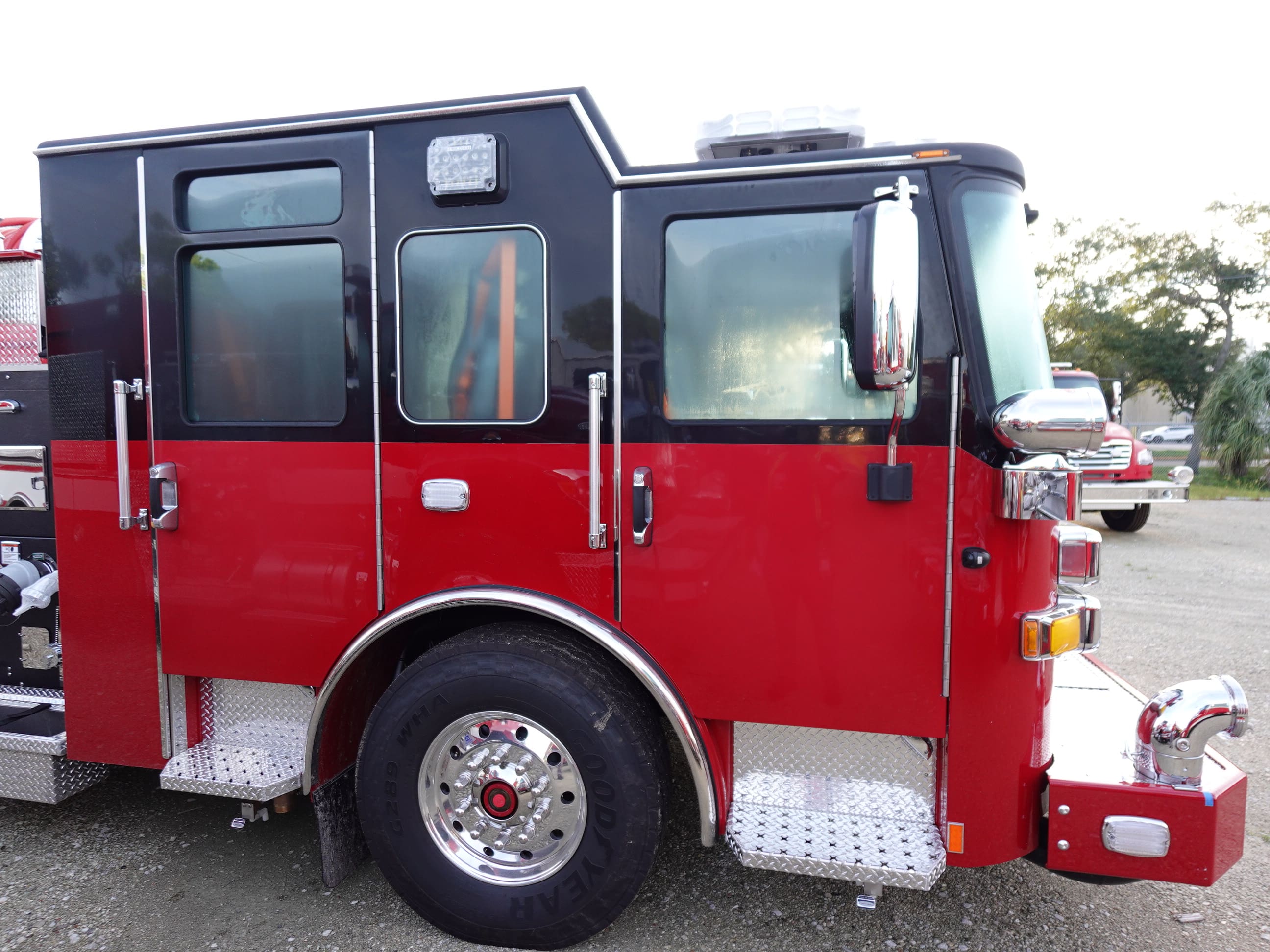

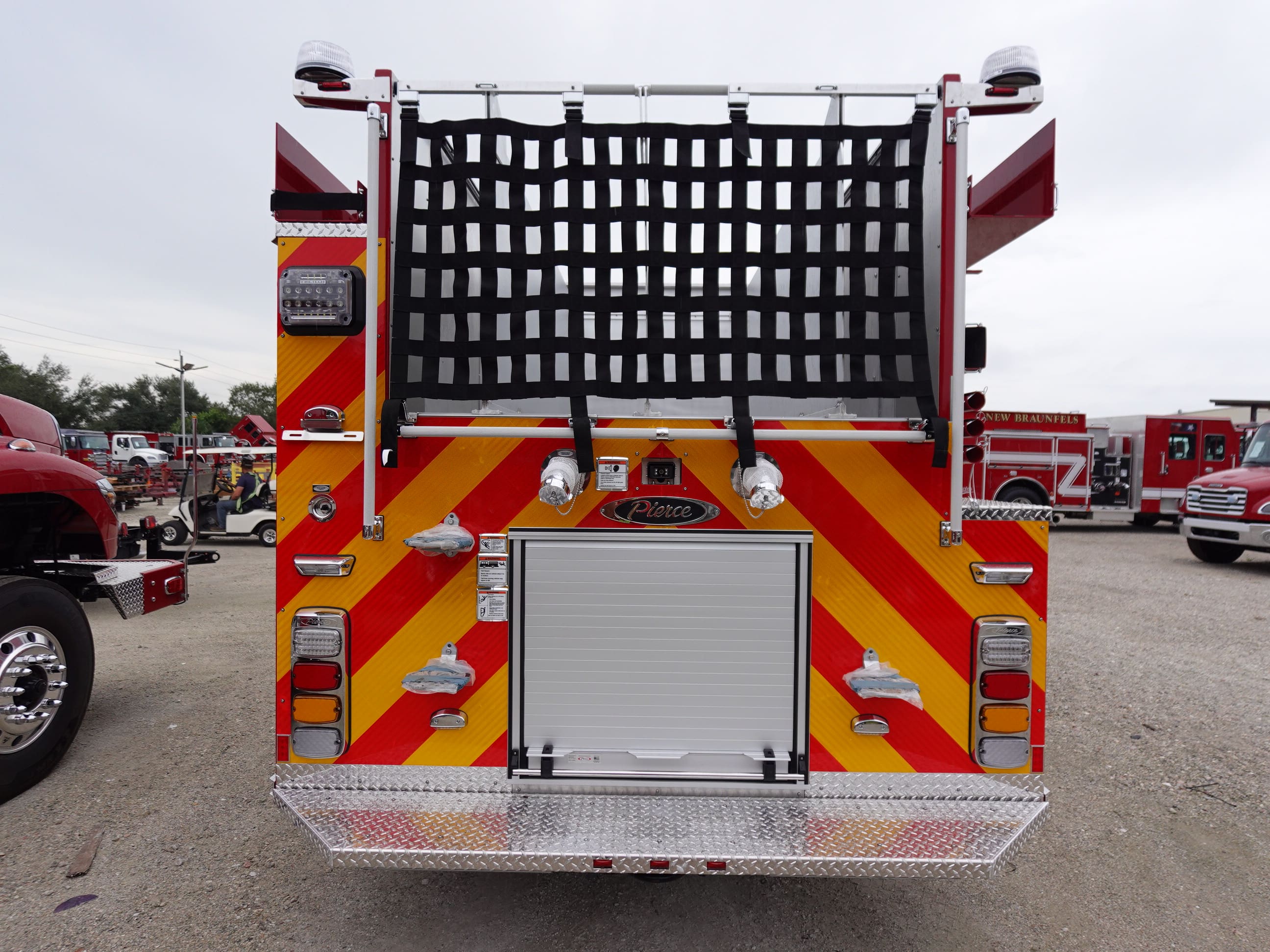

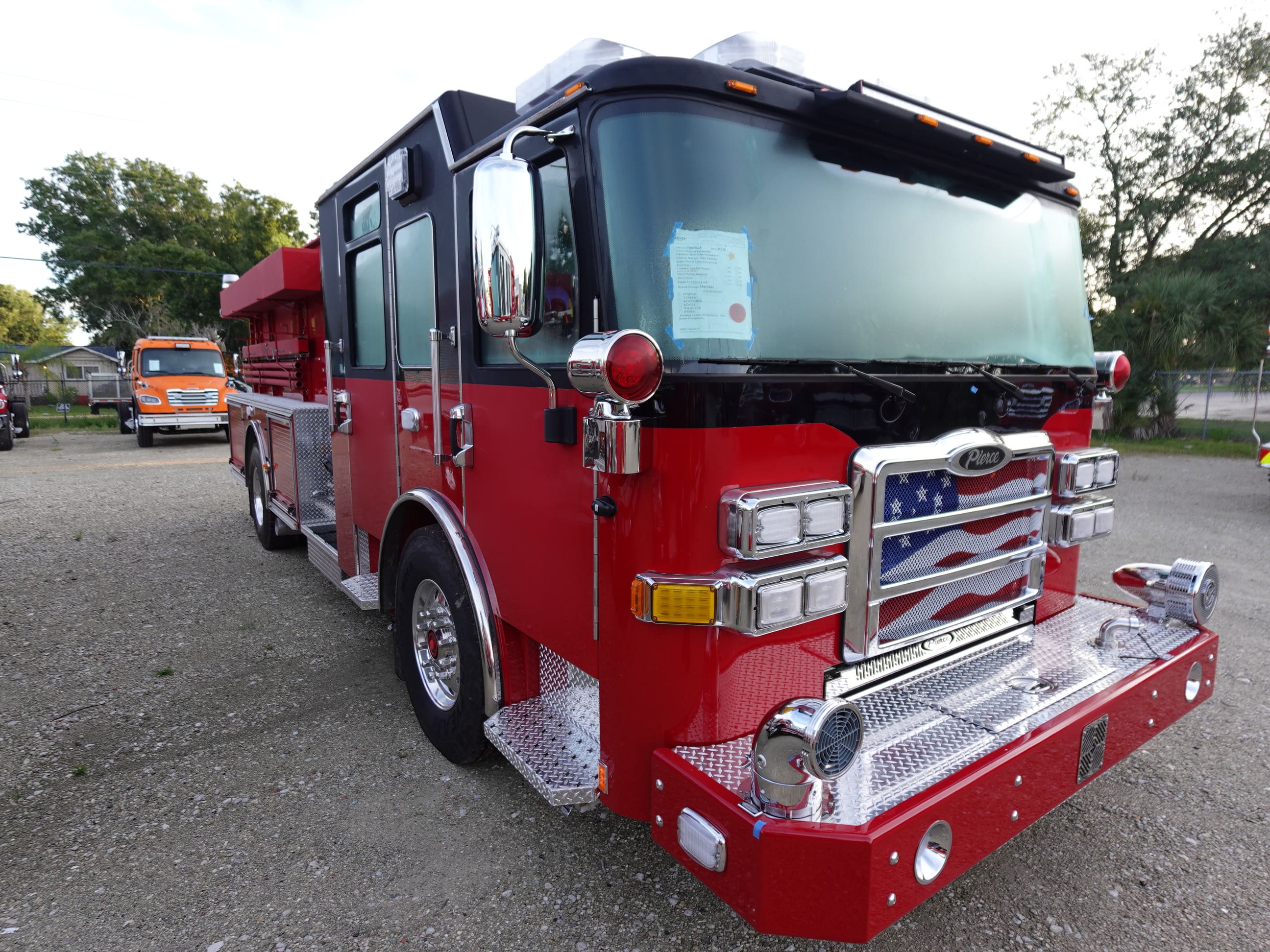

10-09-26

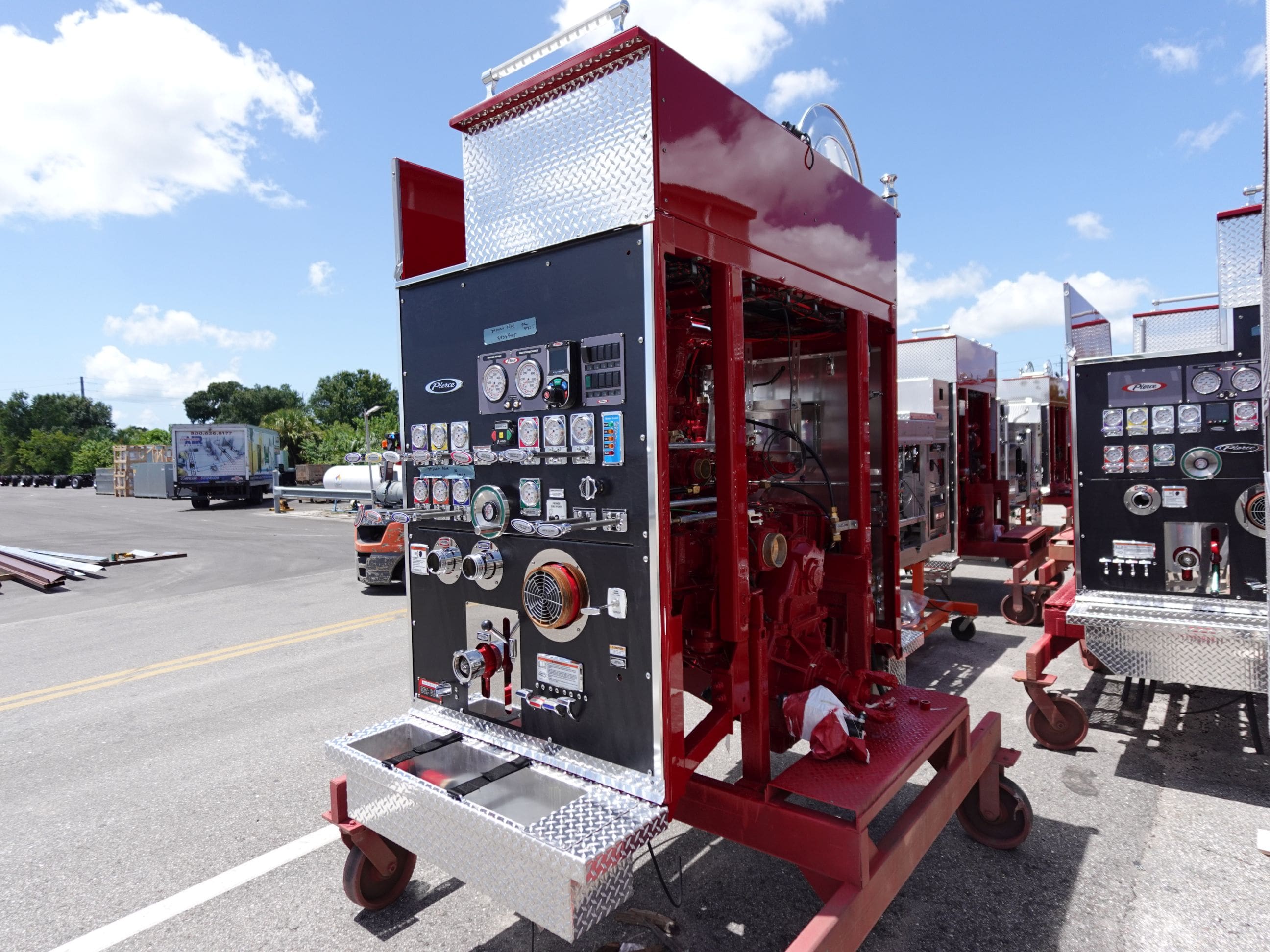

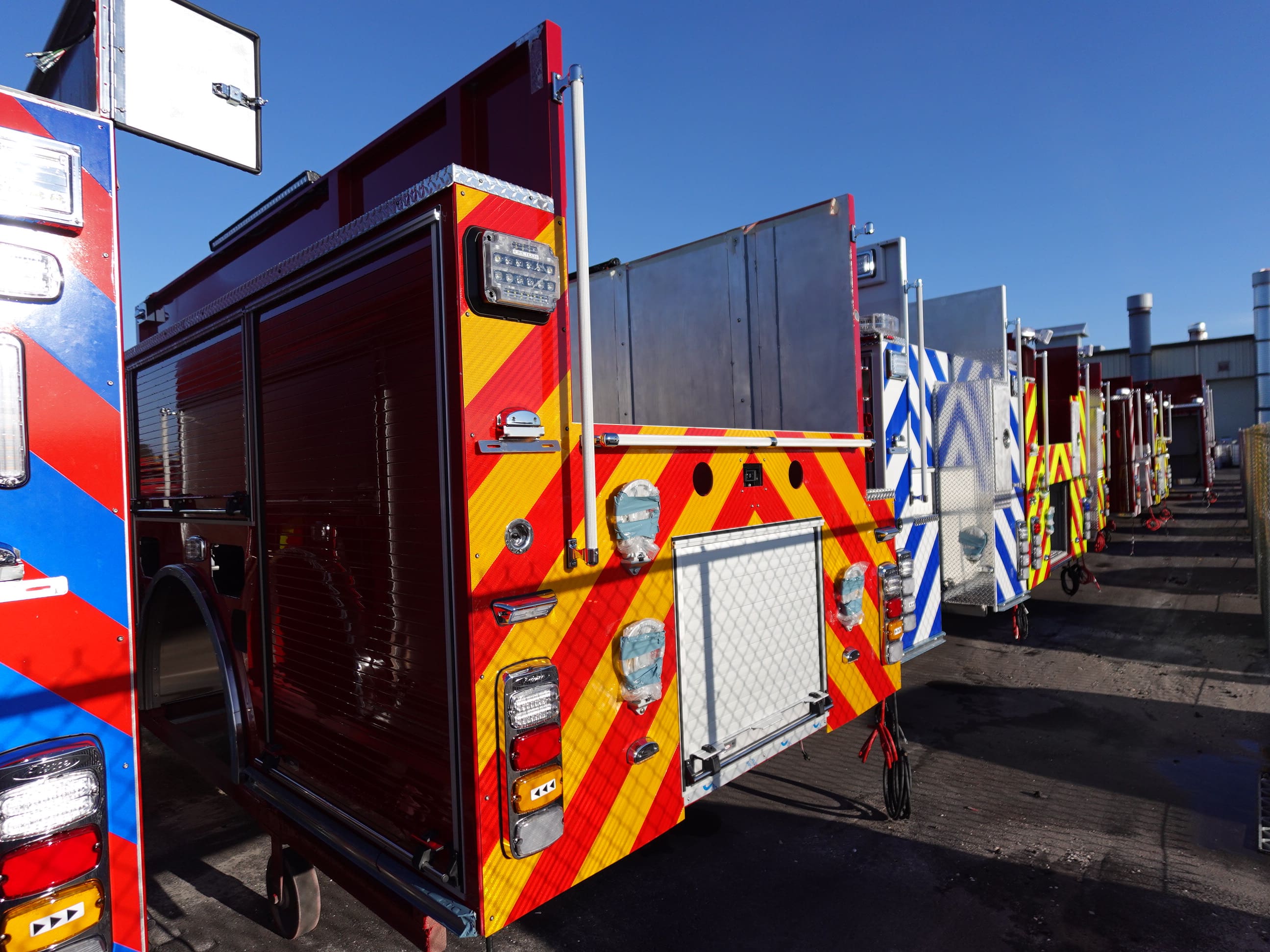

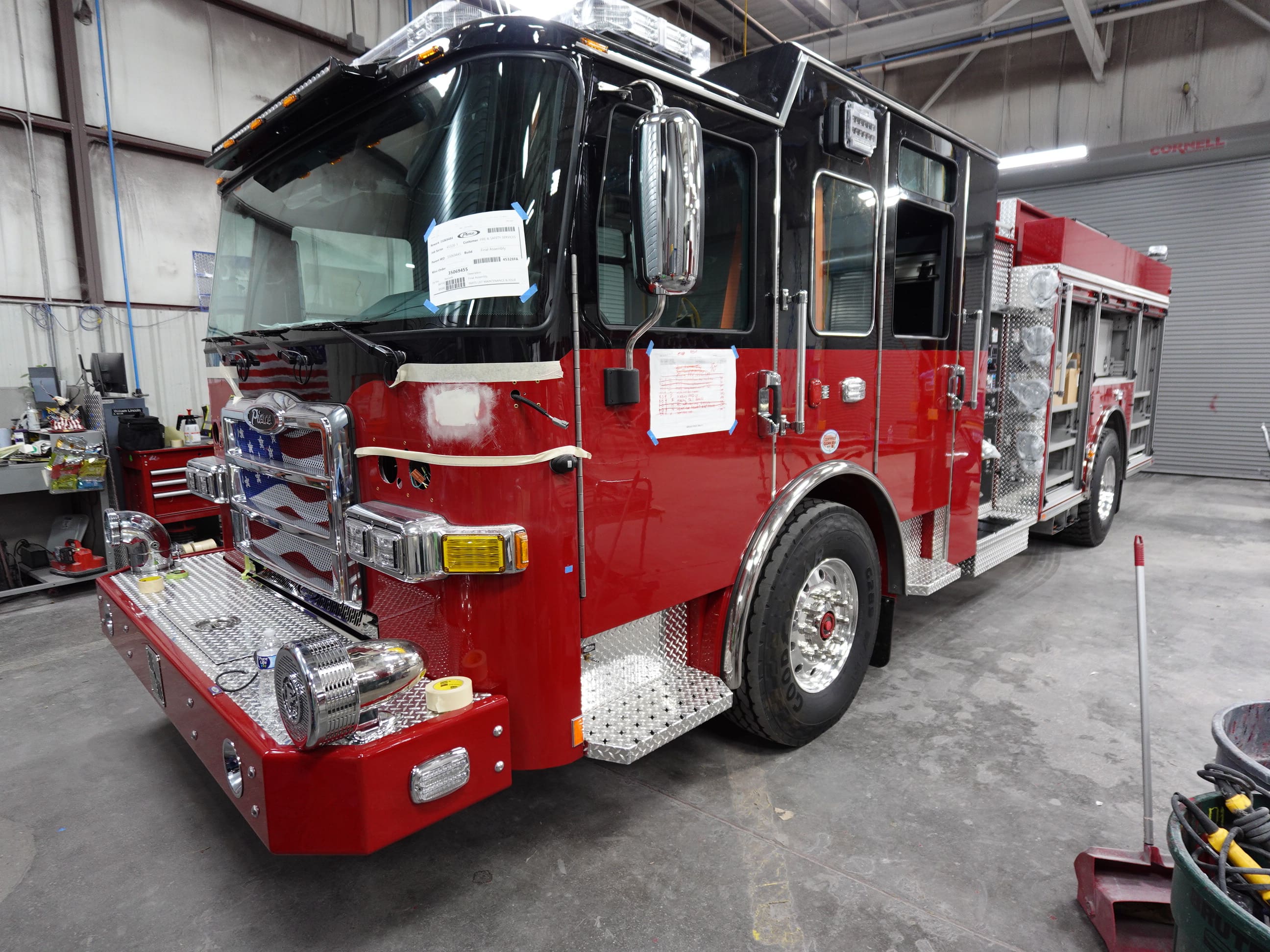

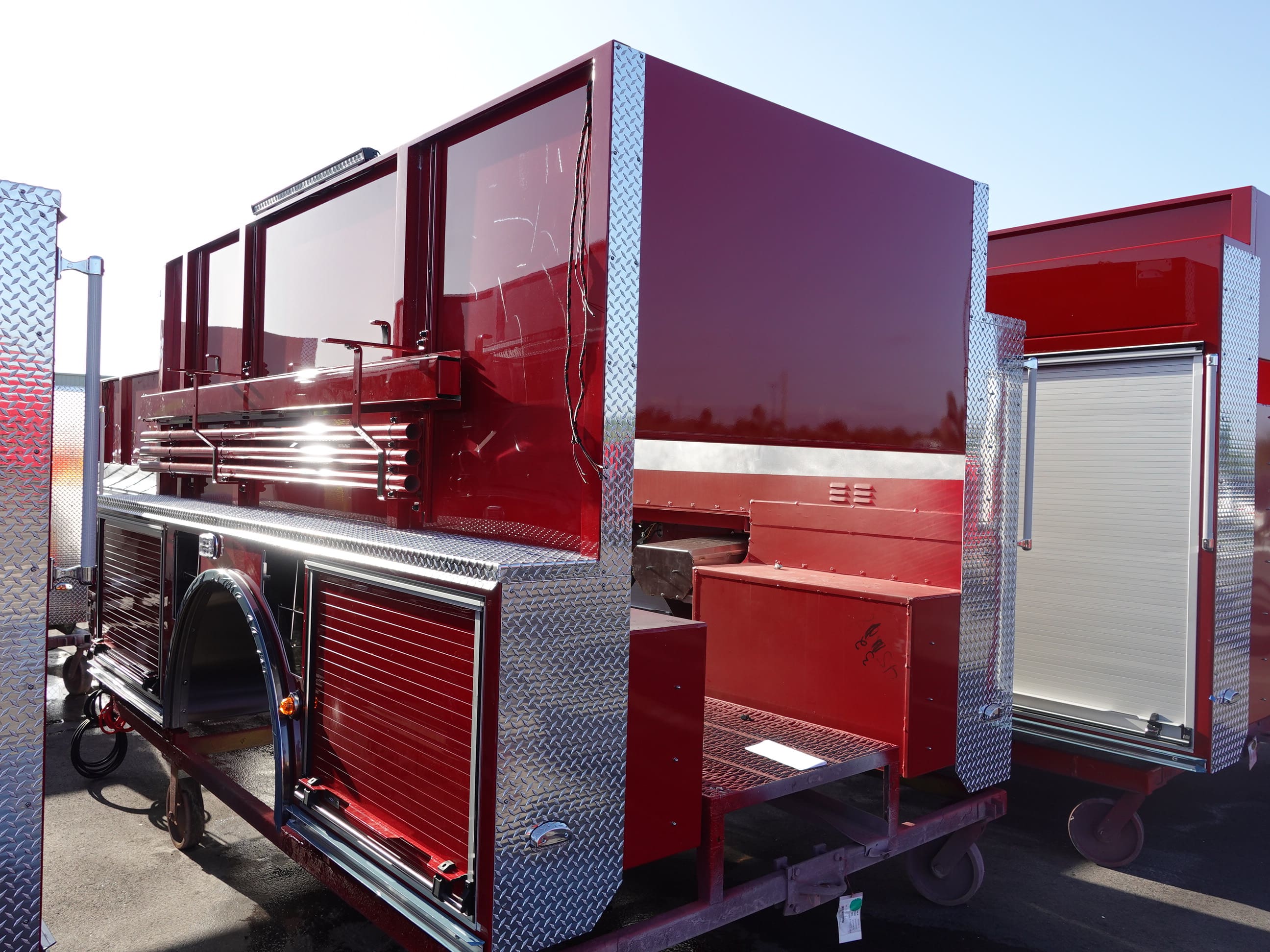

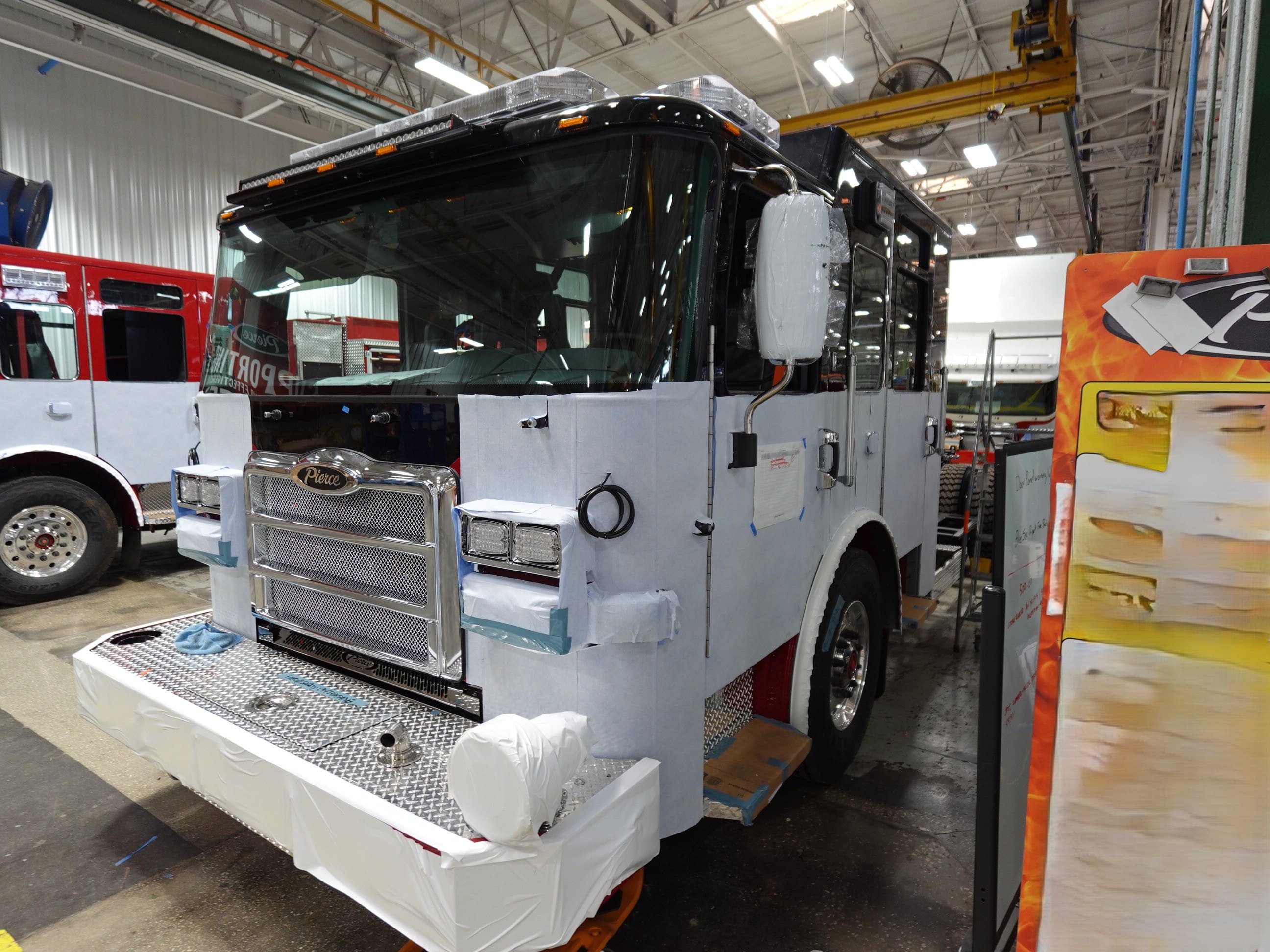

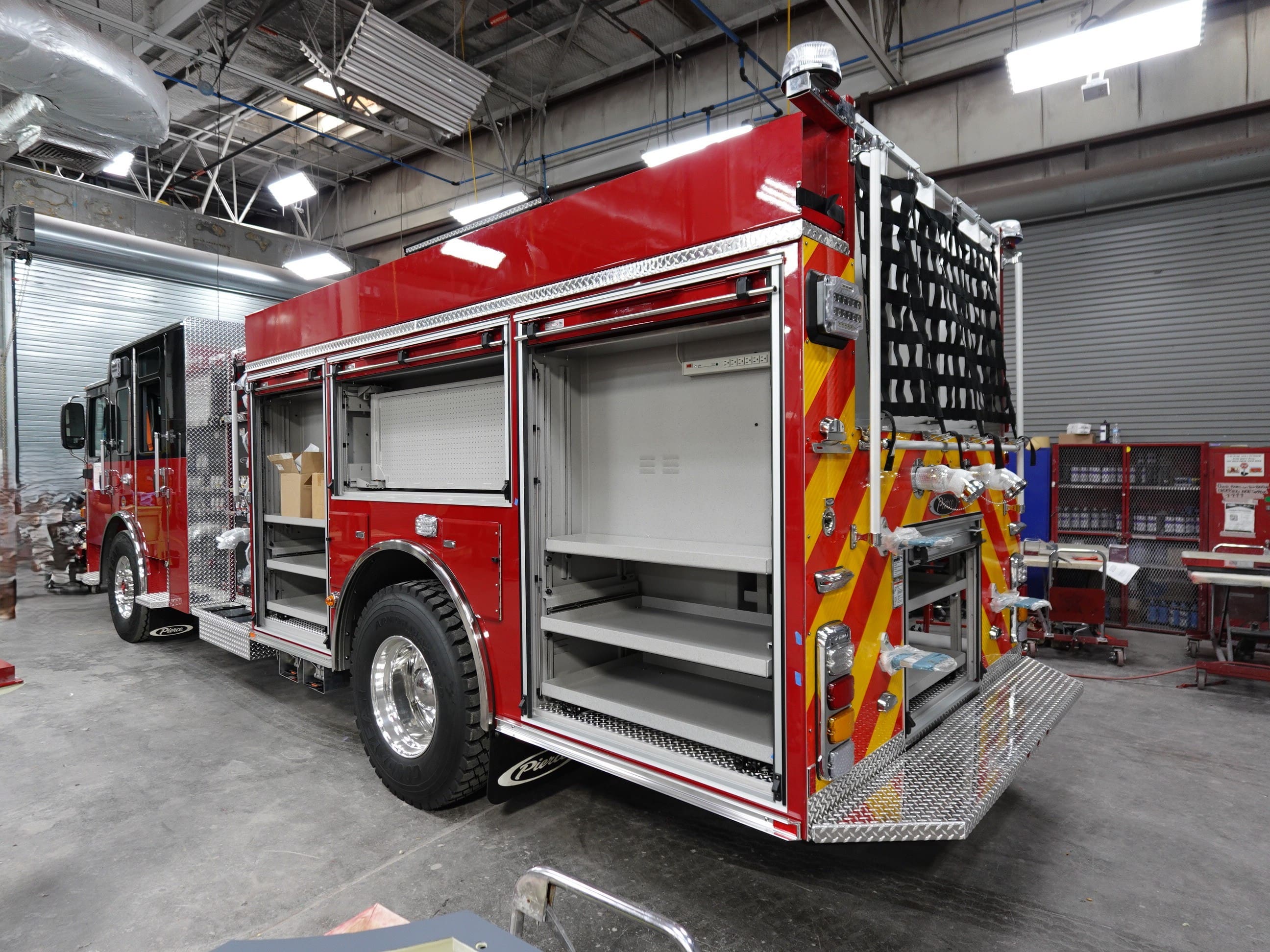

In this report, the apparatus was staged to complete test.
Once testing completes it will release to final product
evaluation where any remaining content will be applied.
When finished it will be made ready for the customer
acceptance inspection. This is the last scheduled report.
09-04-26

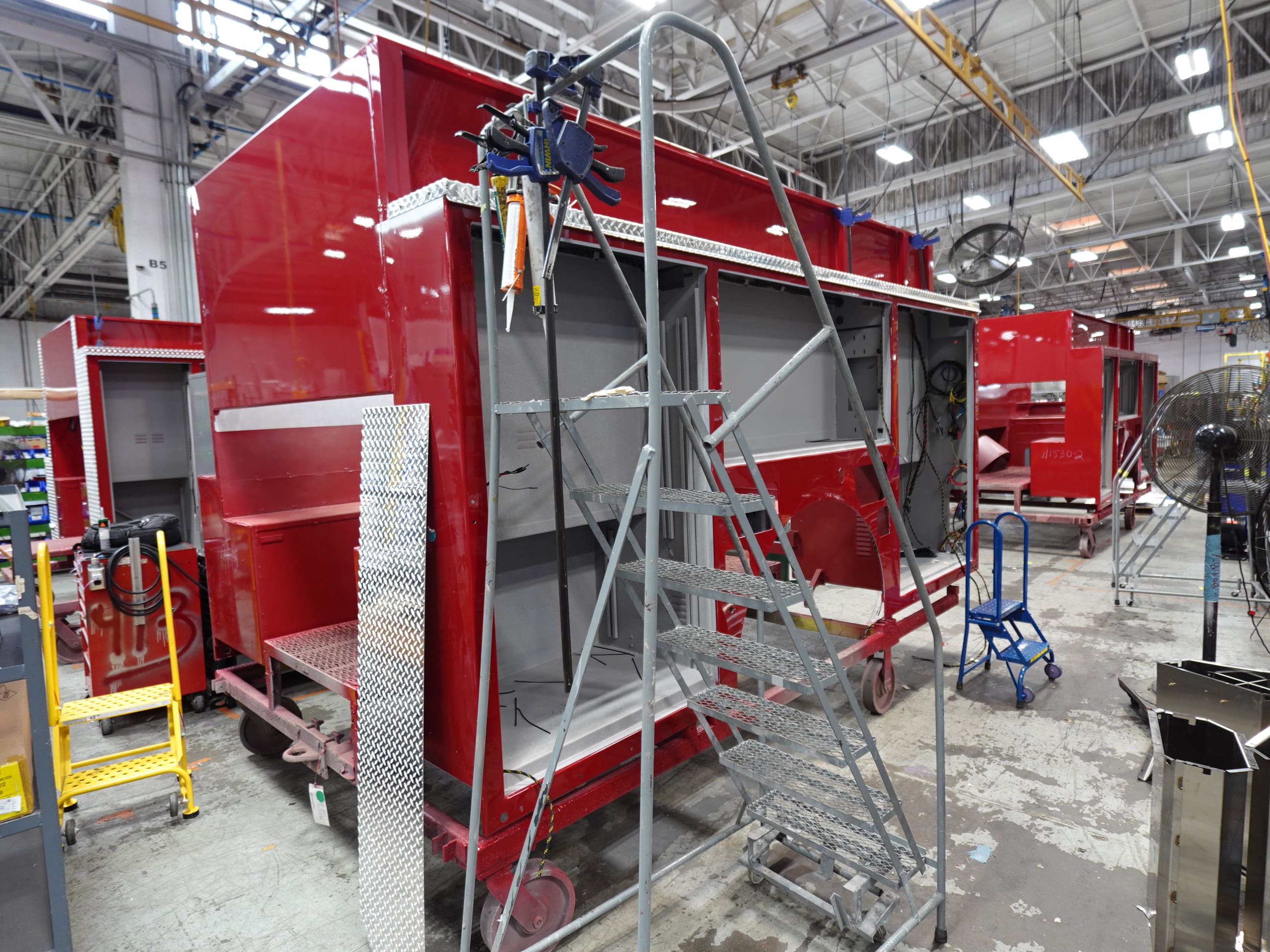

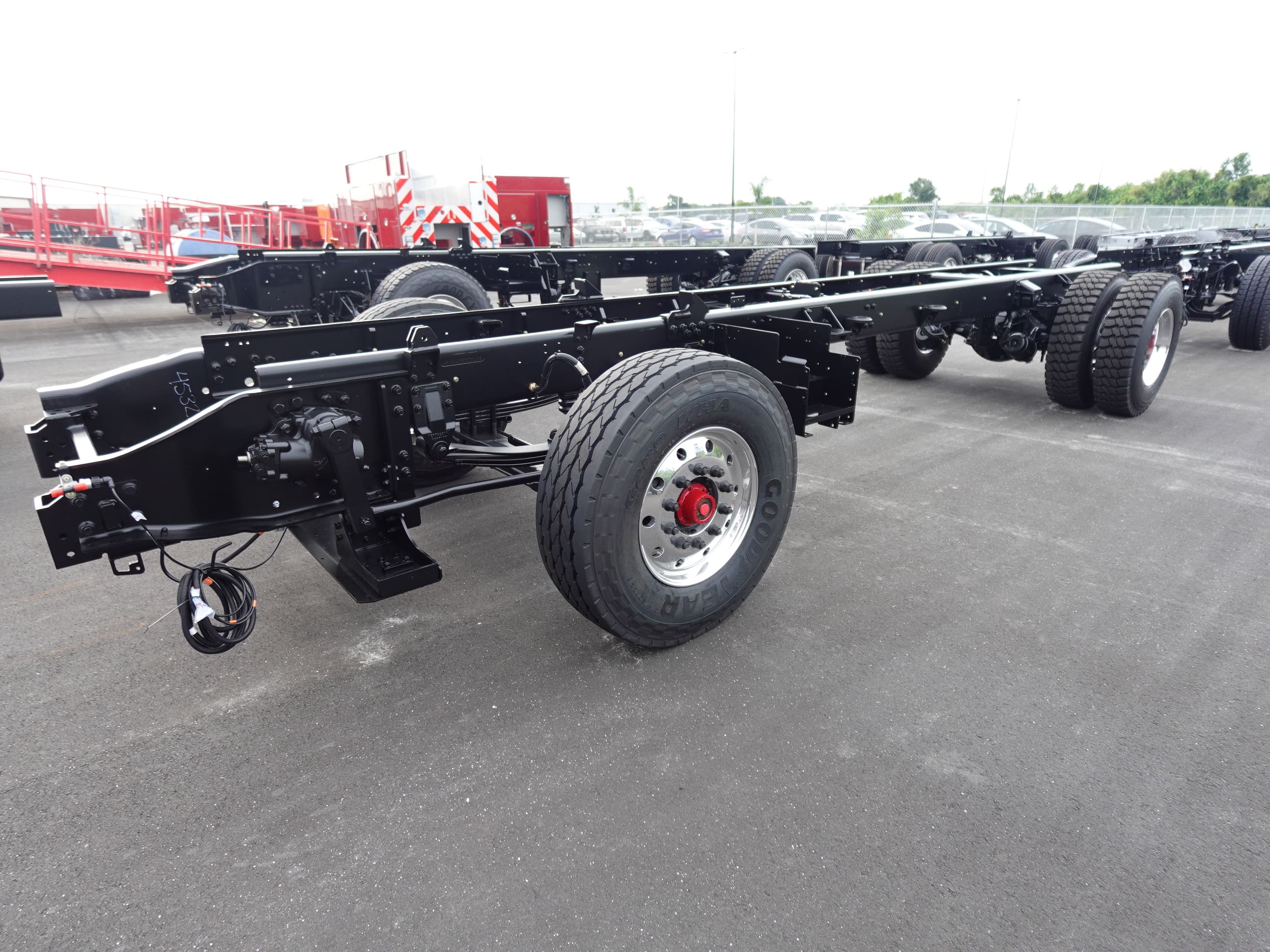

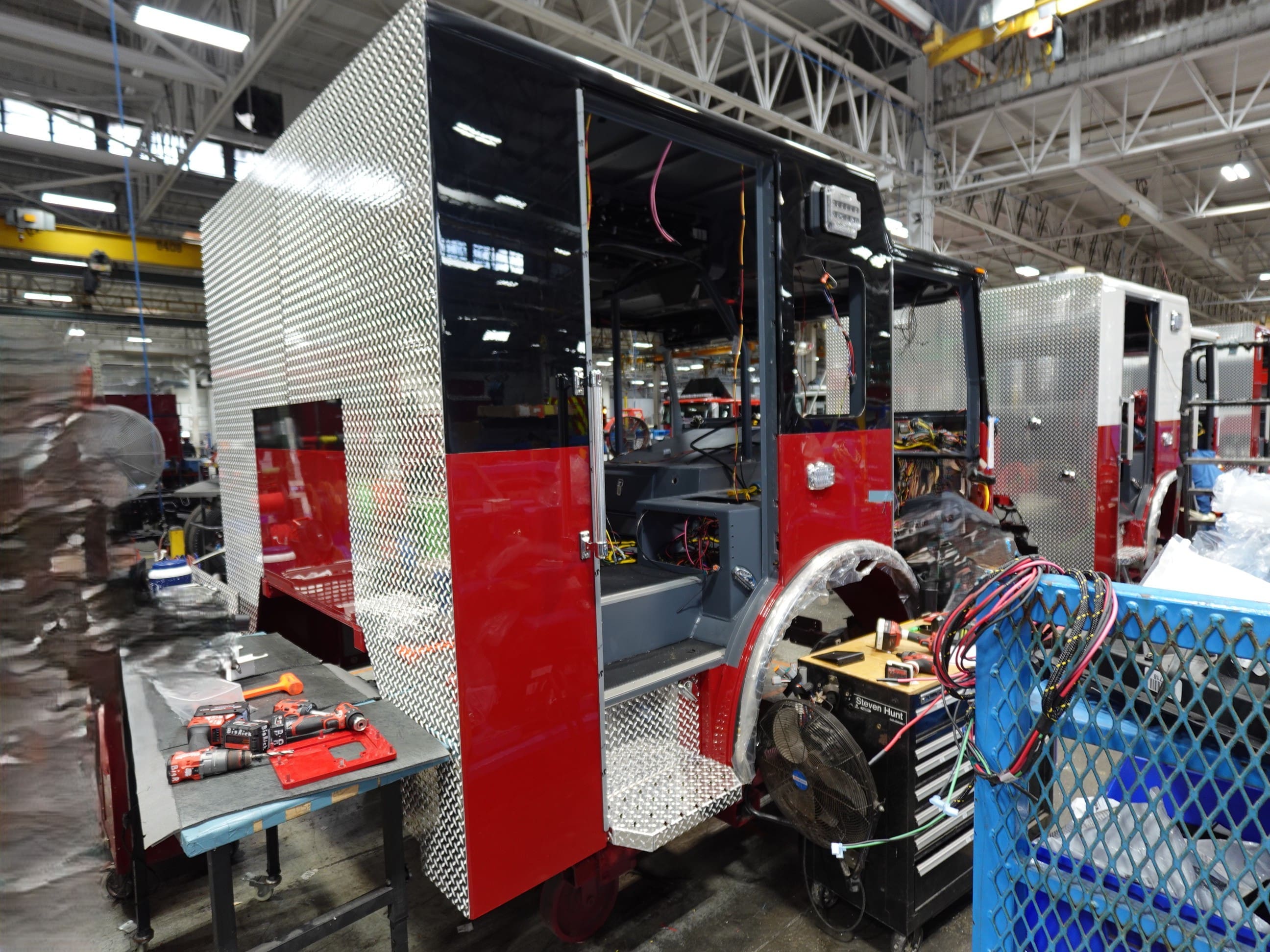

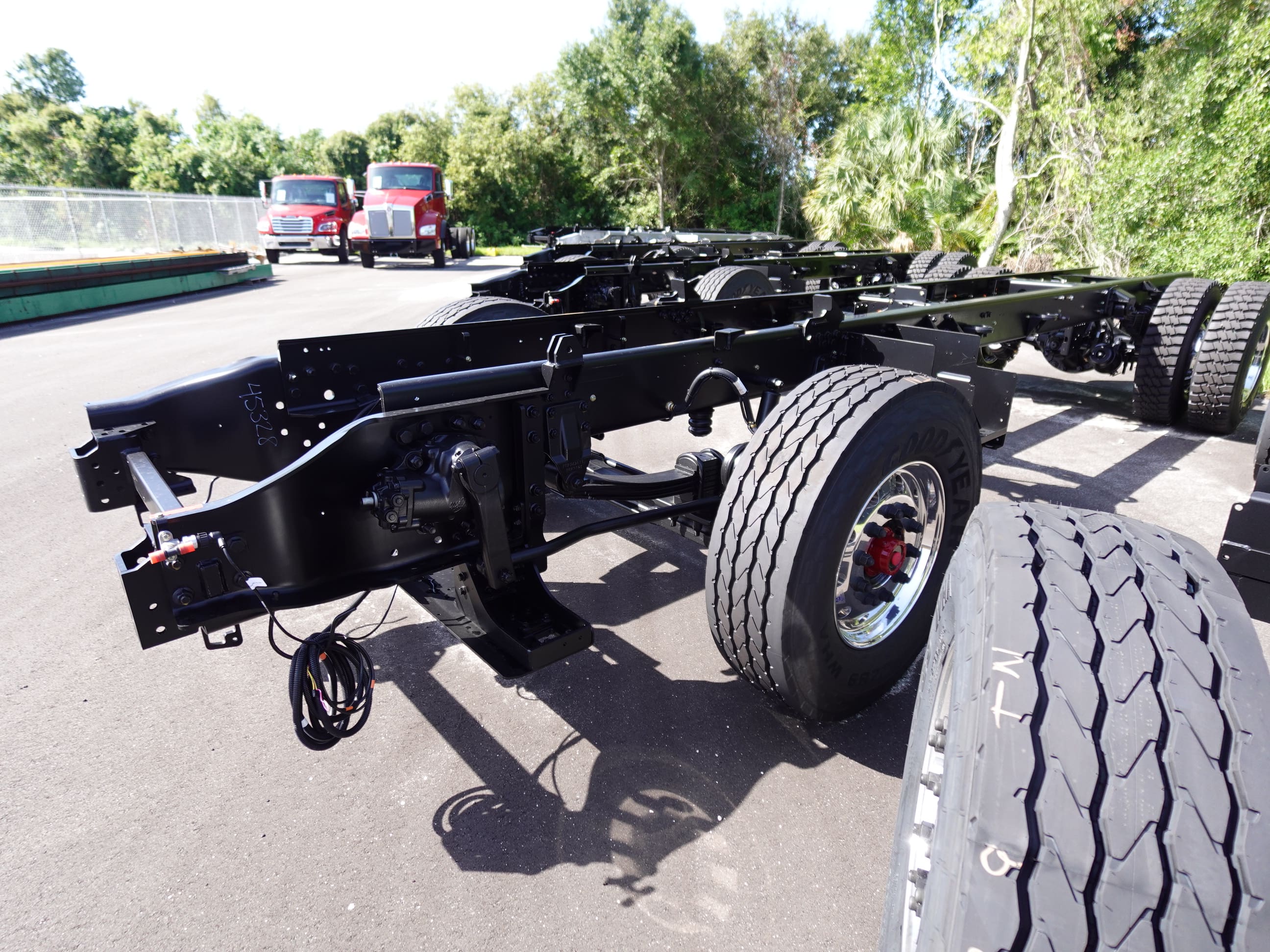

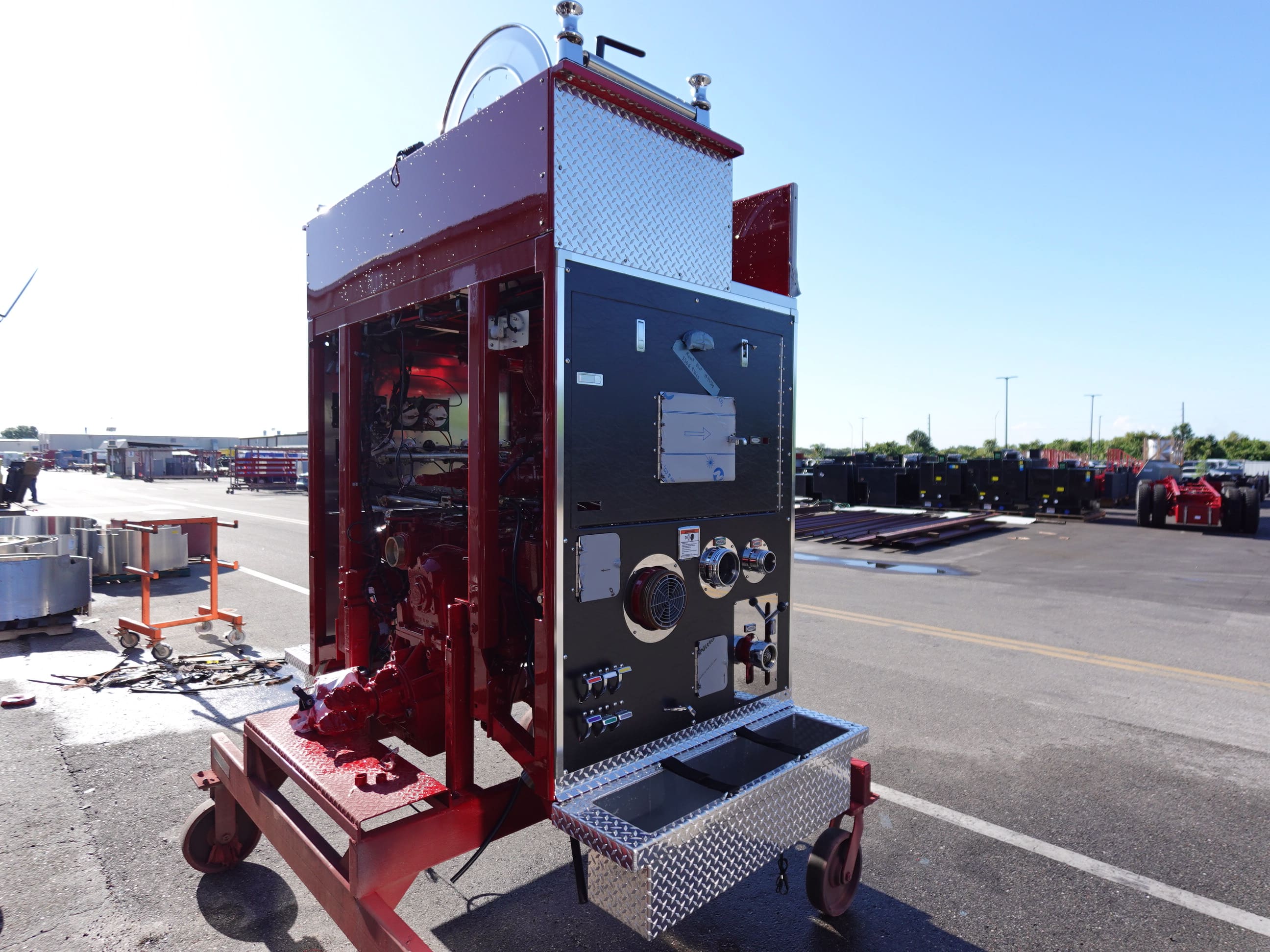

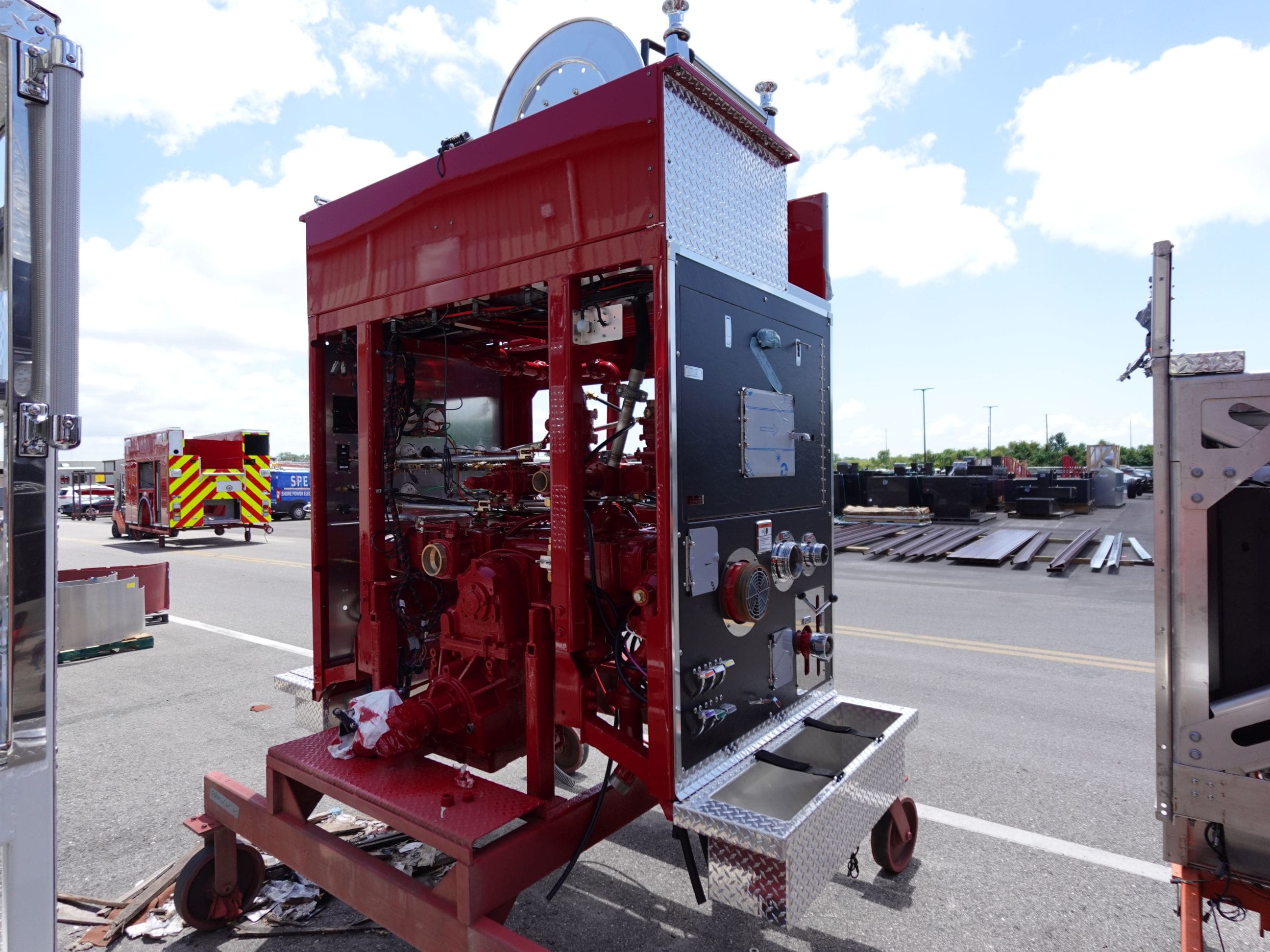

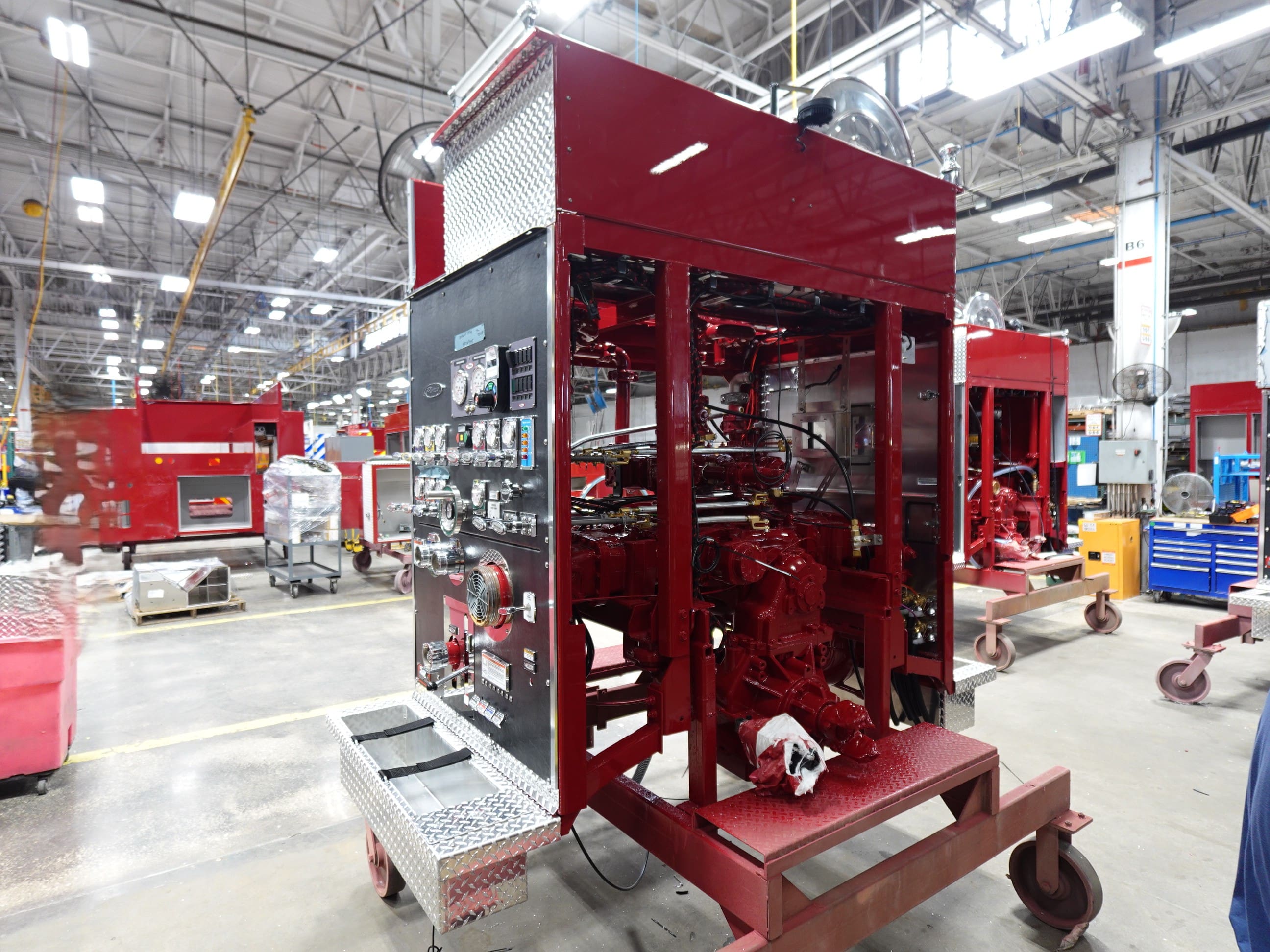

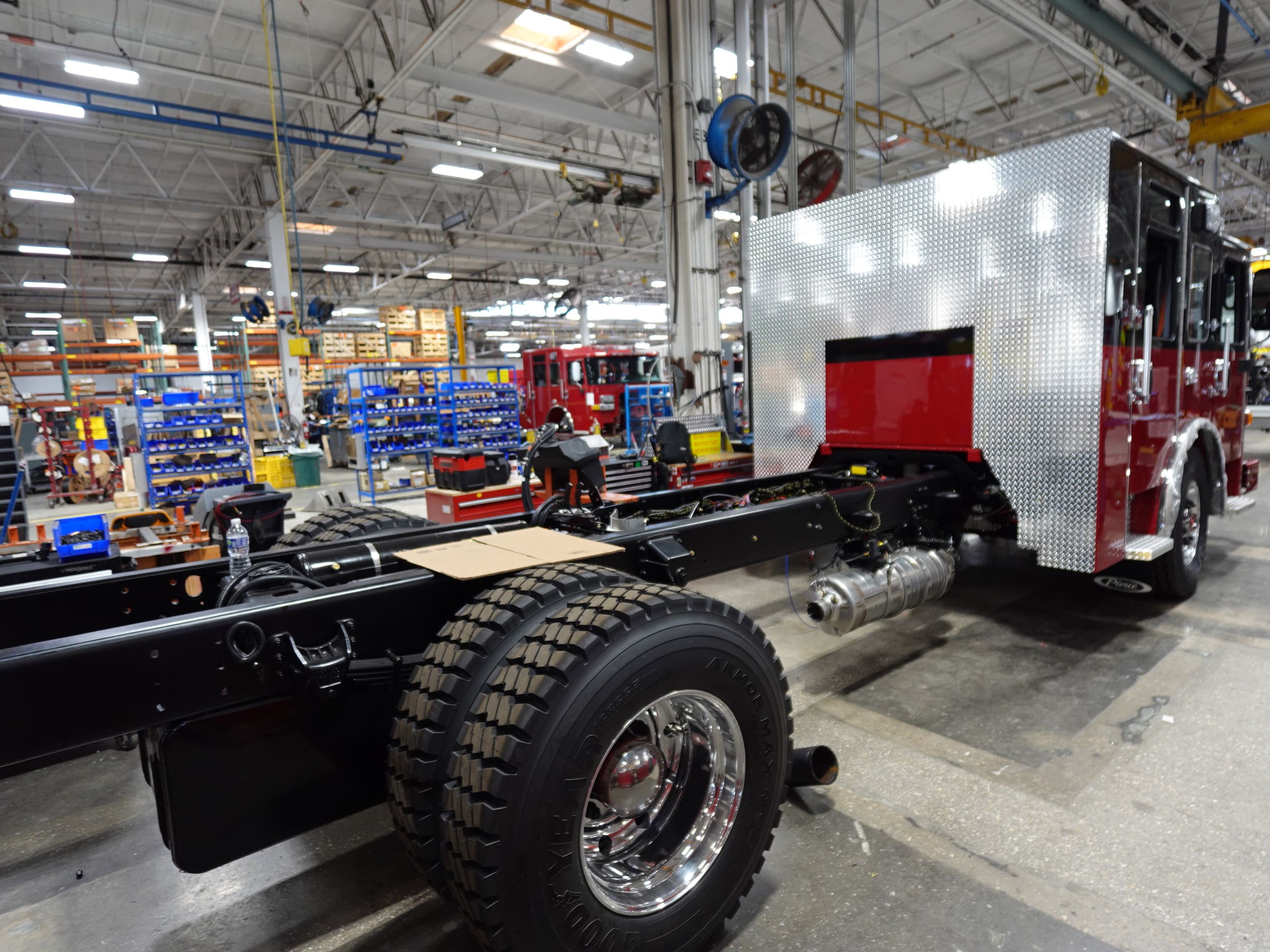

In this report, the pump house was merged with the chassis while the body remained staged.
08-28-26

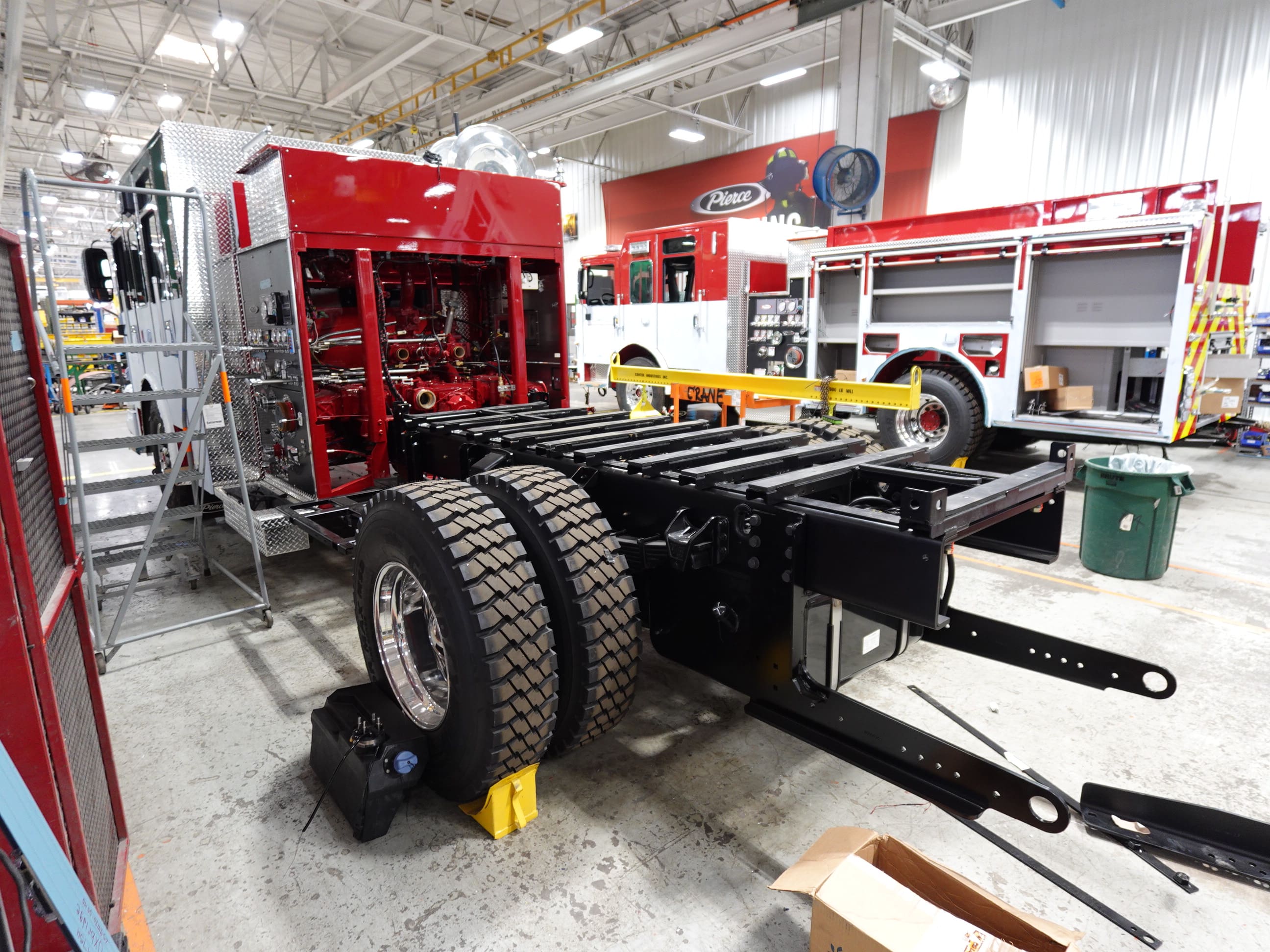

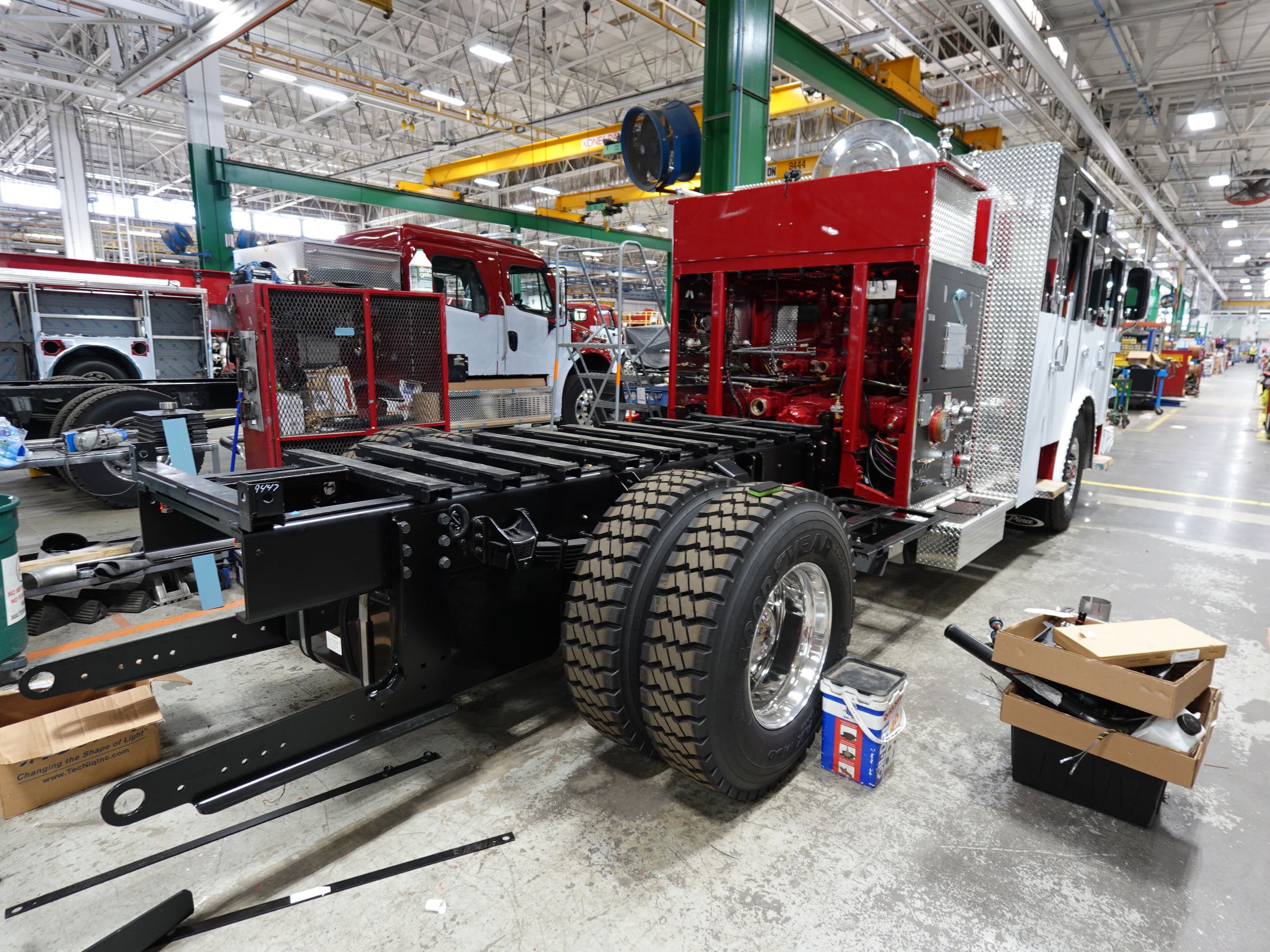

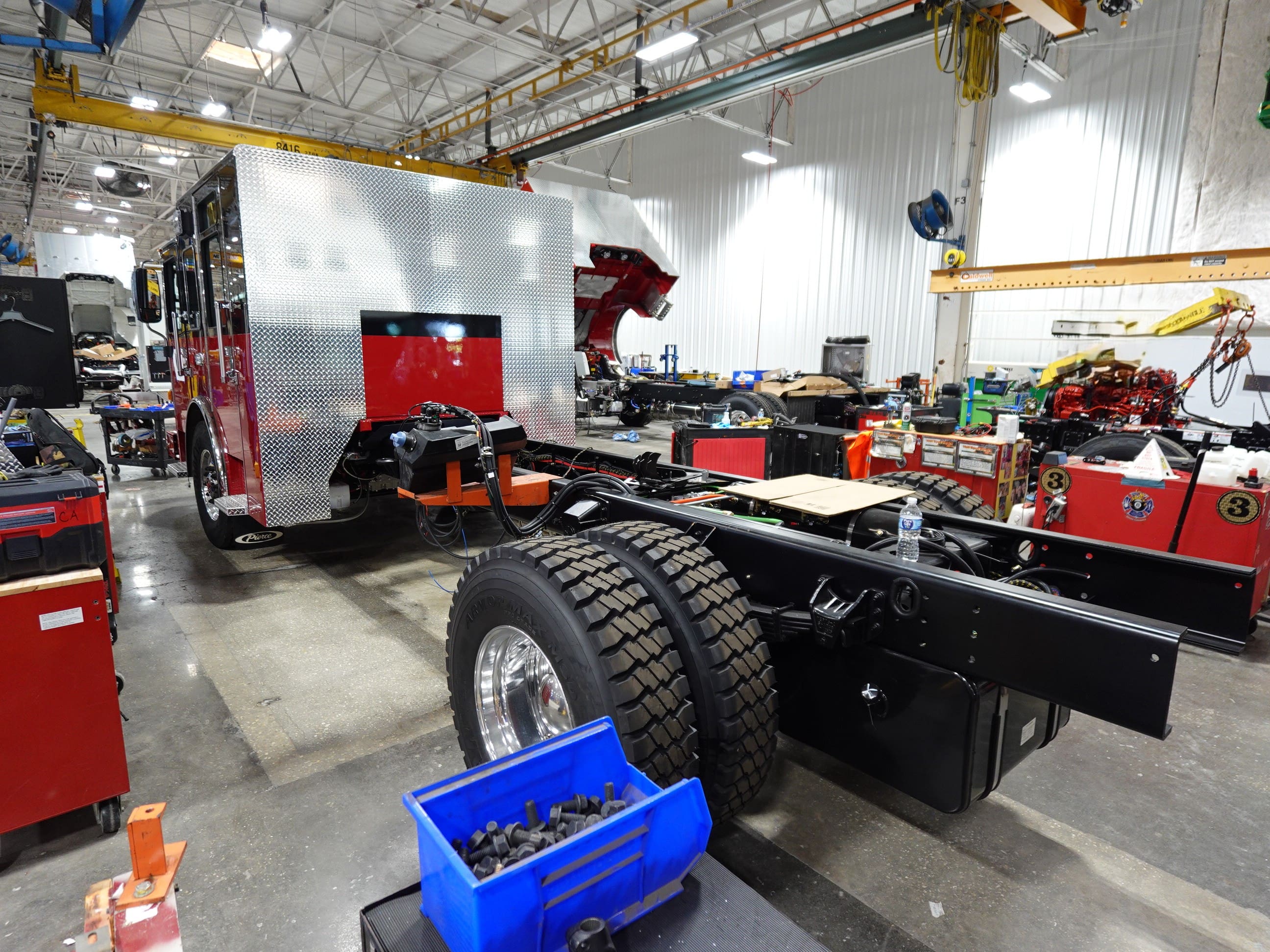

In this report, the cab was merged with the frame while the pump house and the body remained staged.

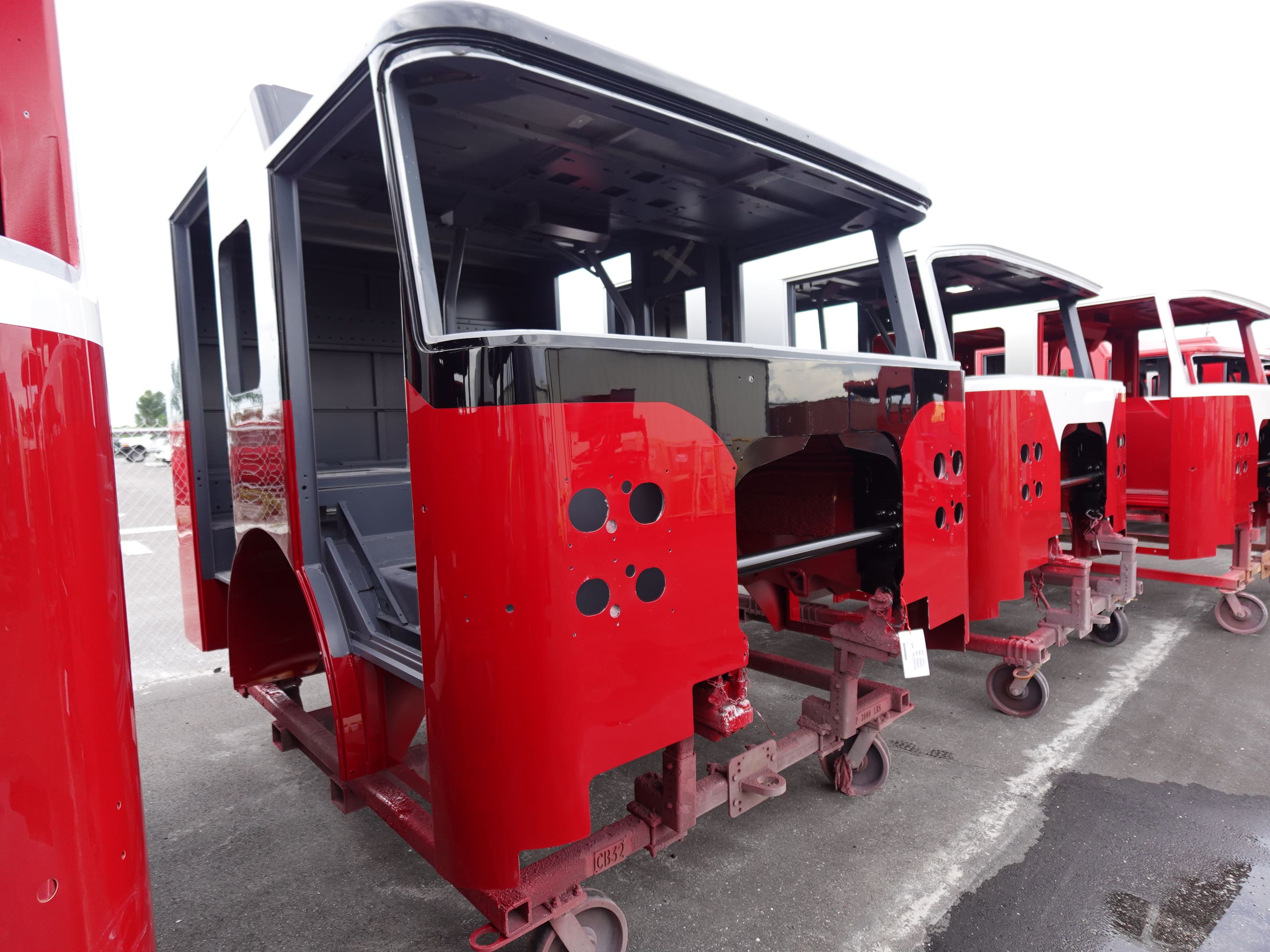

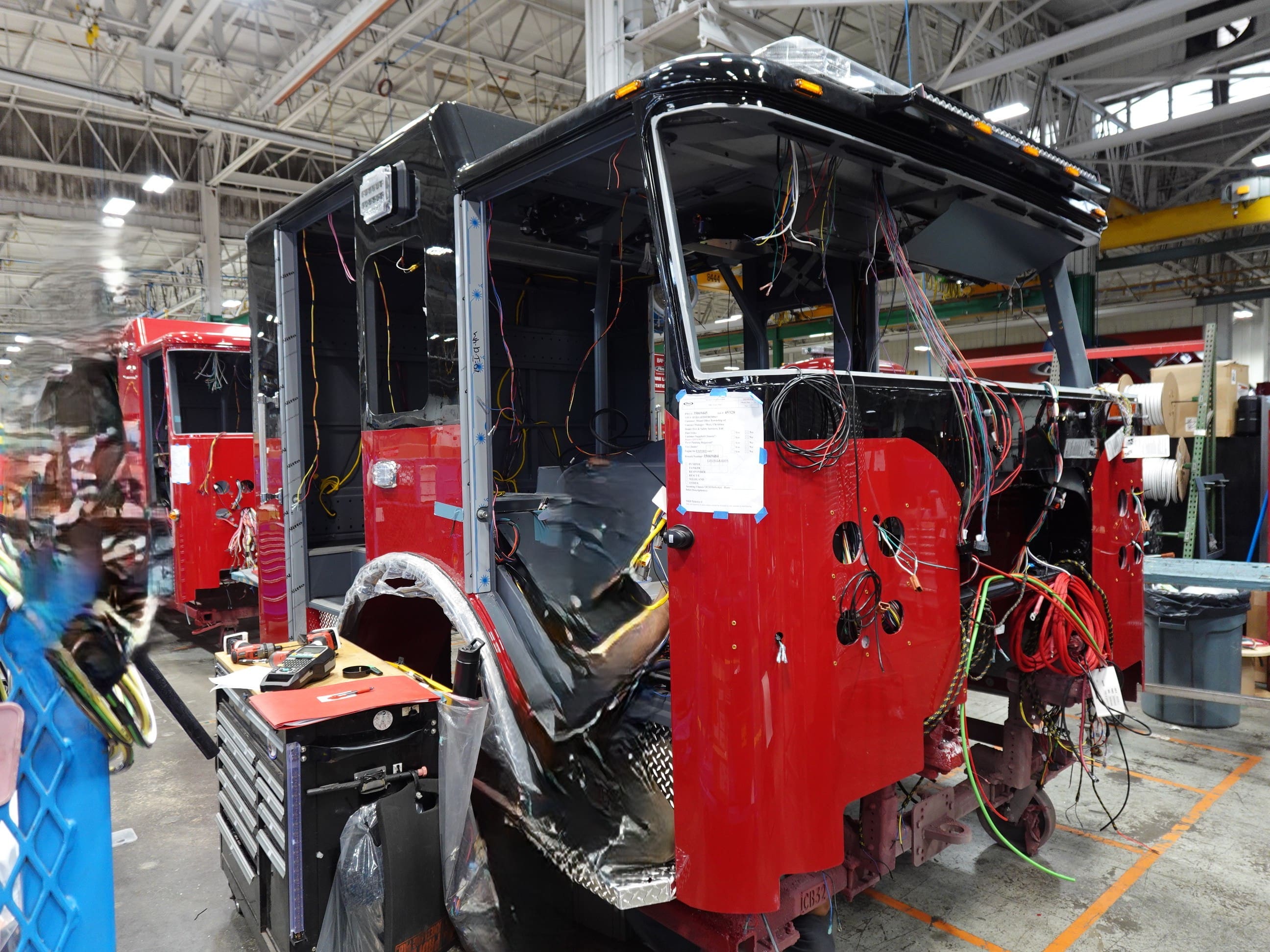

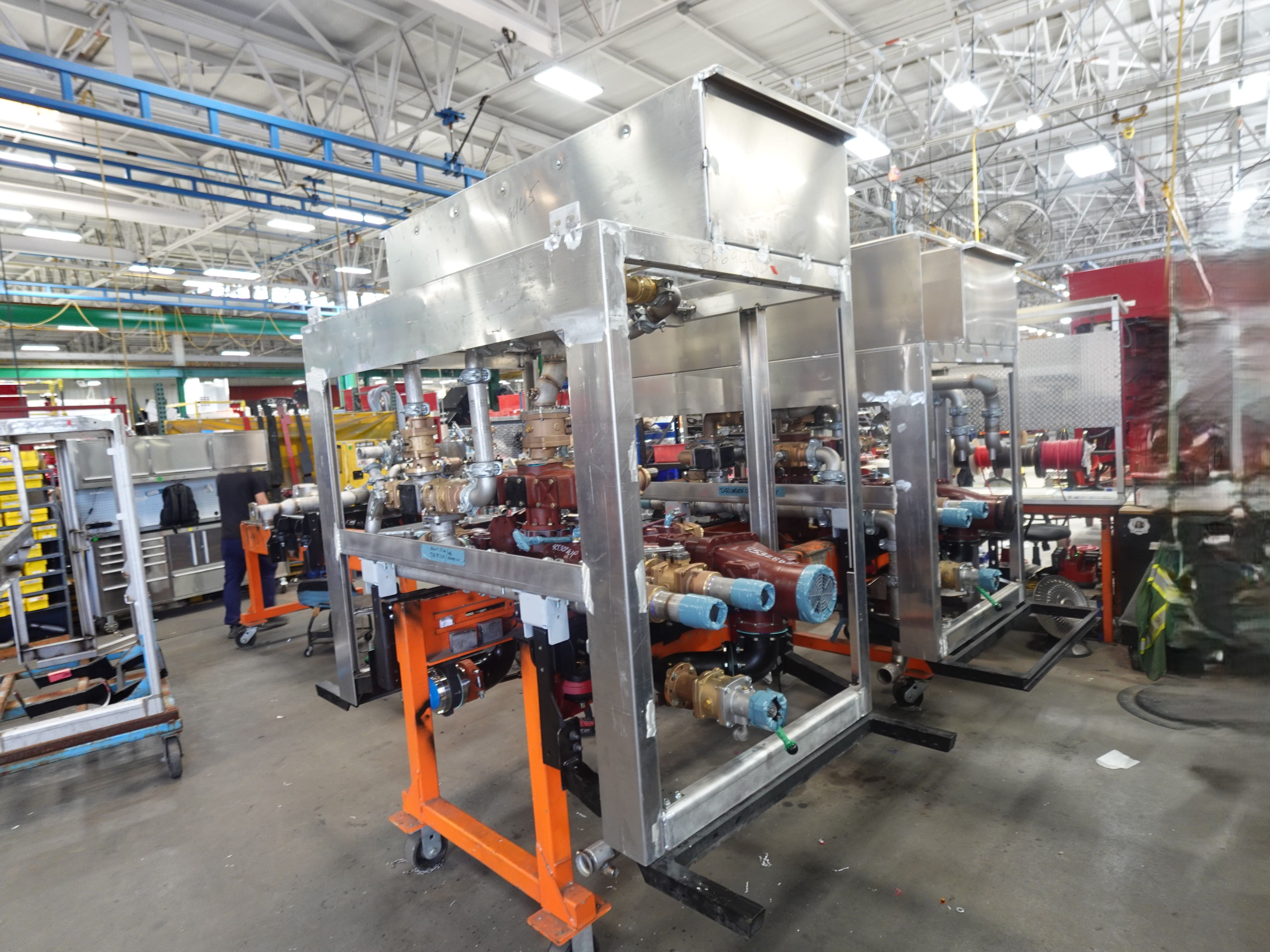

08-21-26

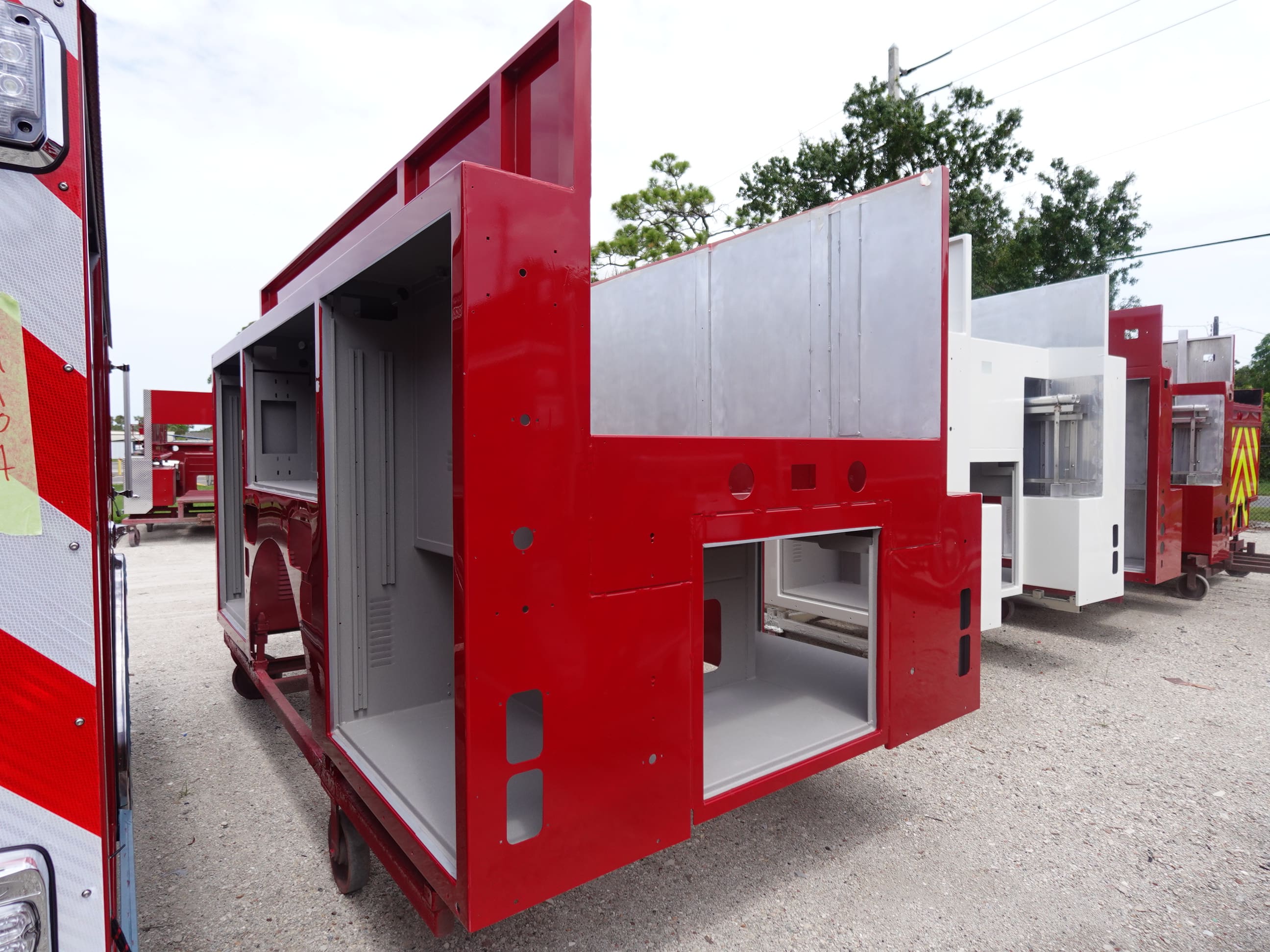

In this report, the cab completed initial assembly, the frame build continued, and the pump house
and the body remained staged.
08-14-26

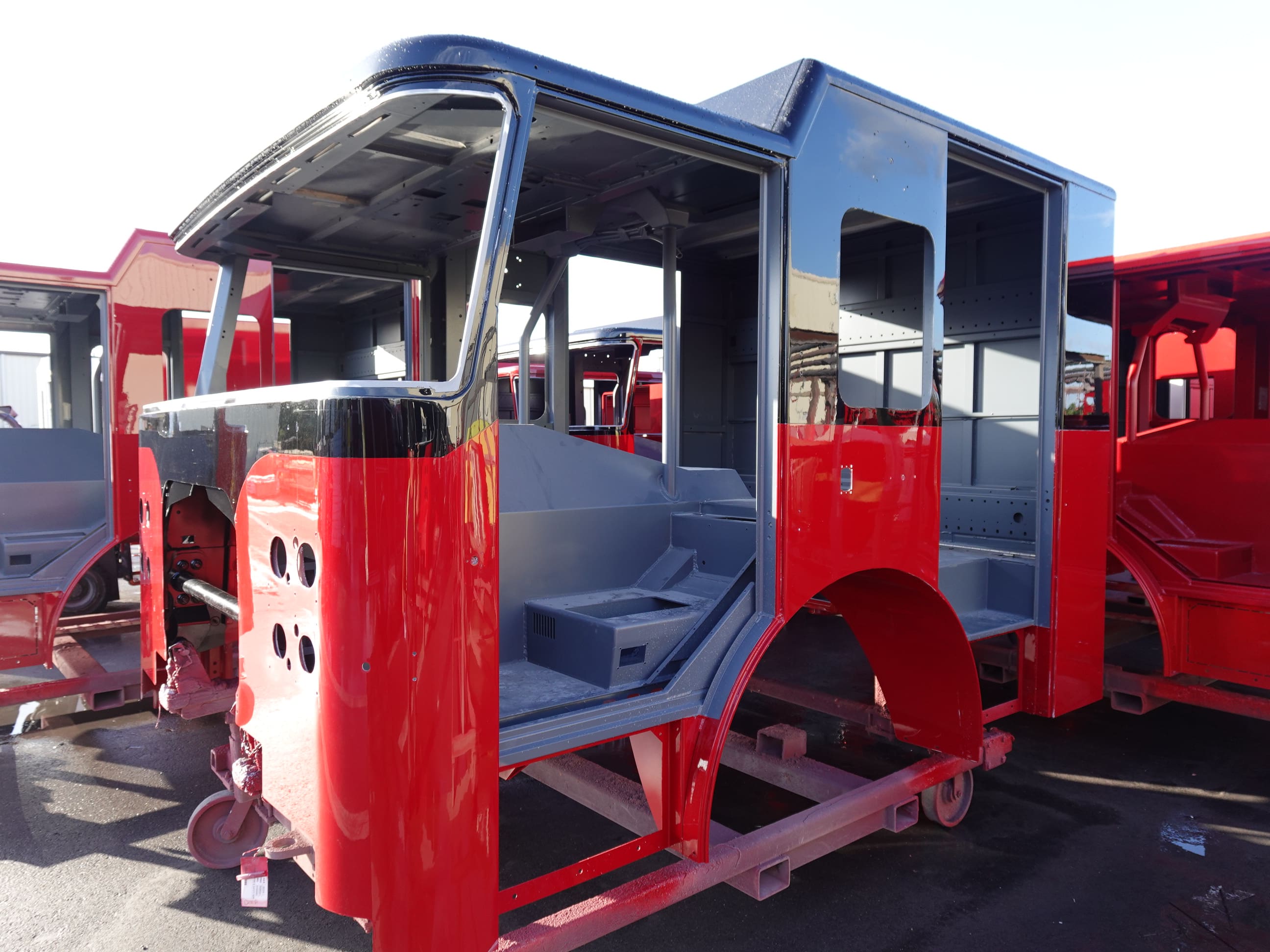

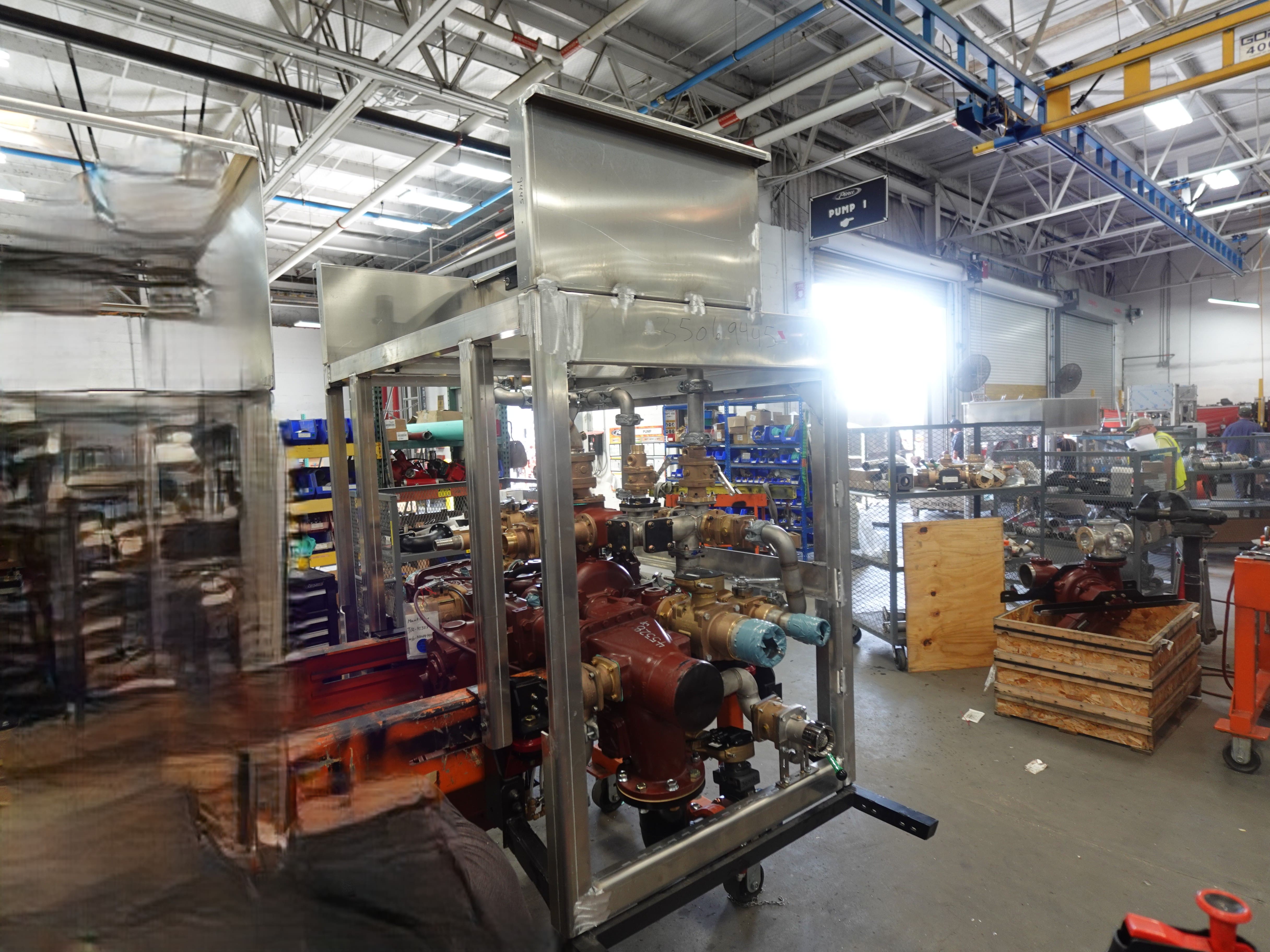

In this report, the cab began initial assembly, the frame remained staged, and the pump house

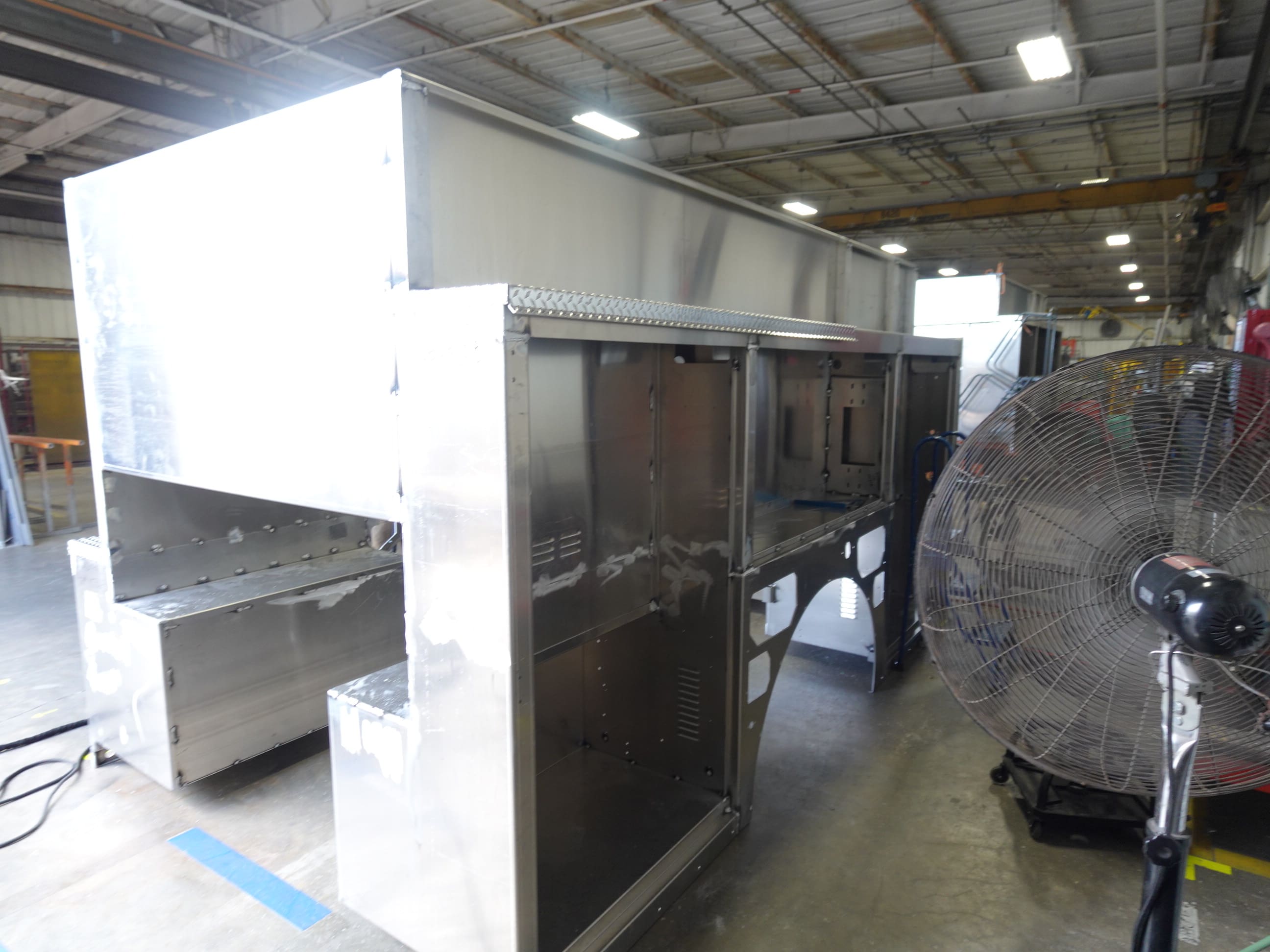

and the body completed initial assembly.

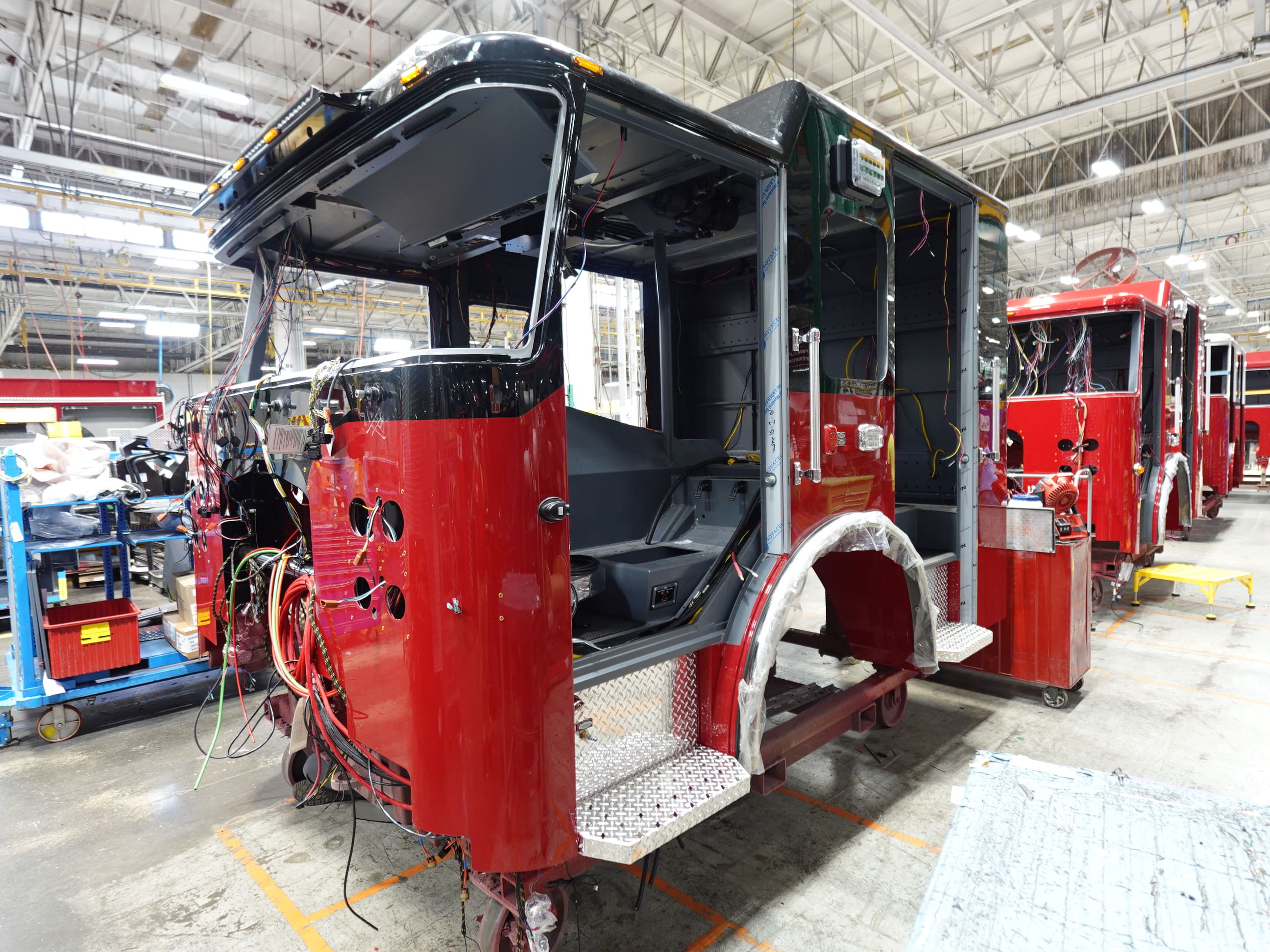

08-07-26
In this report, the cab remained staged to begin initial assembly, the frame was staged, the pump
house continued initial assembly, and the body began initial assembly.

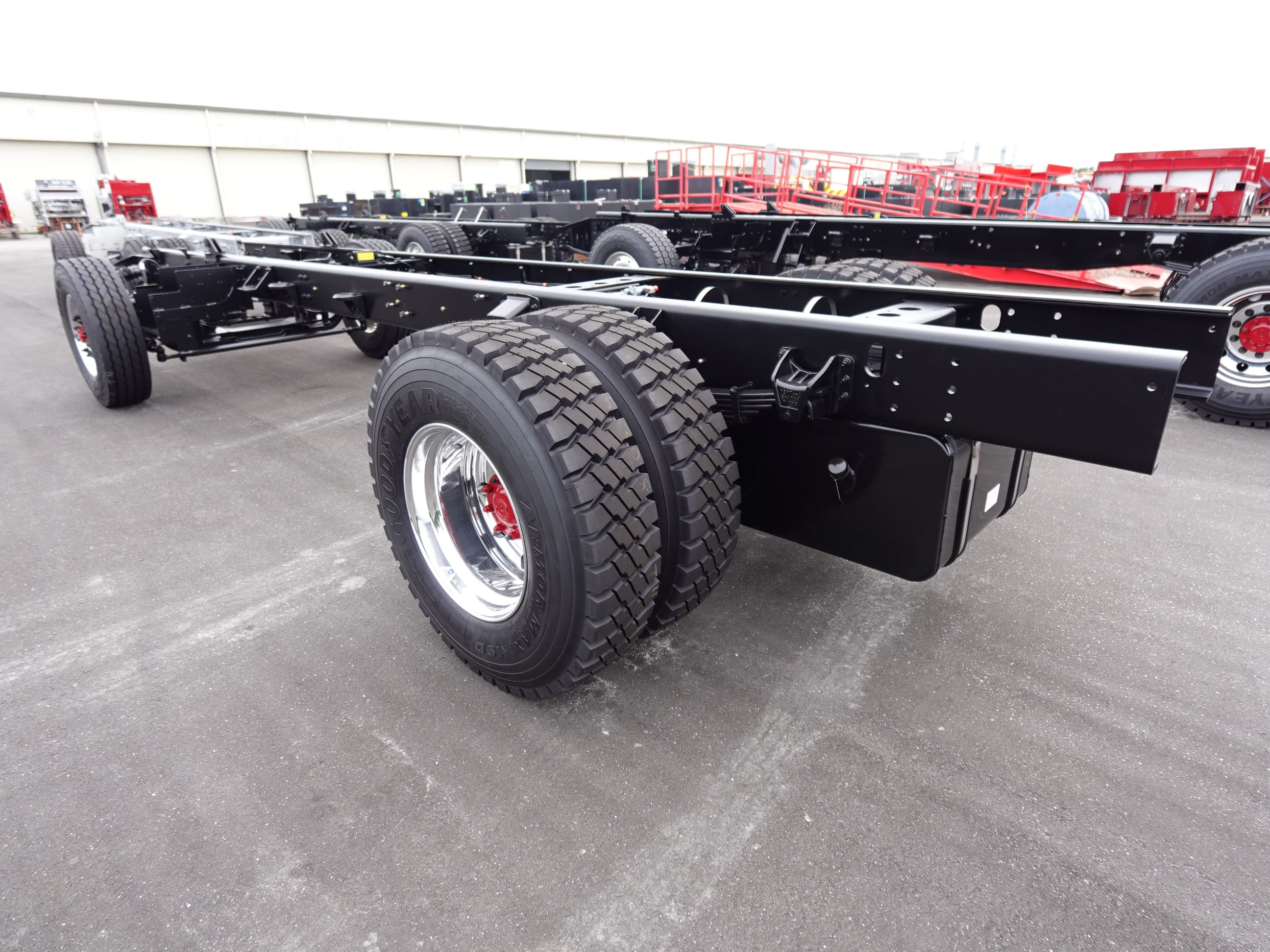

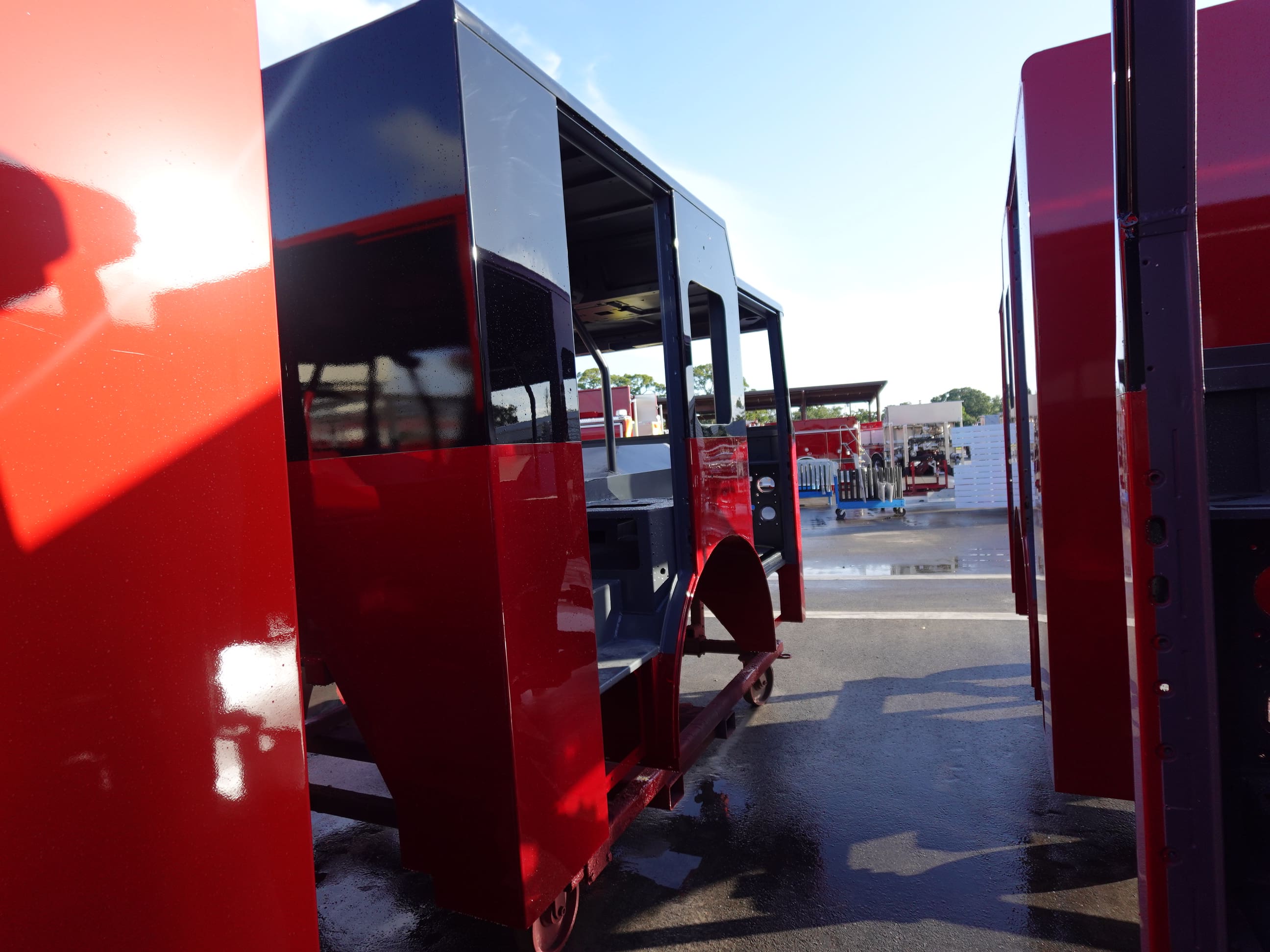

07-31-26

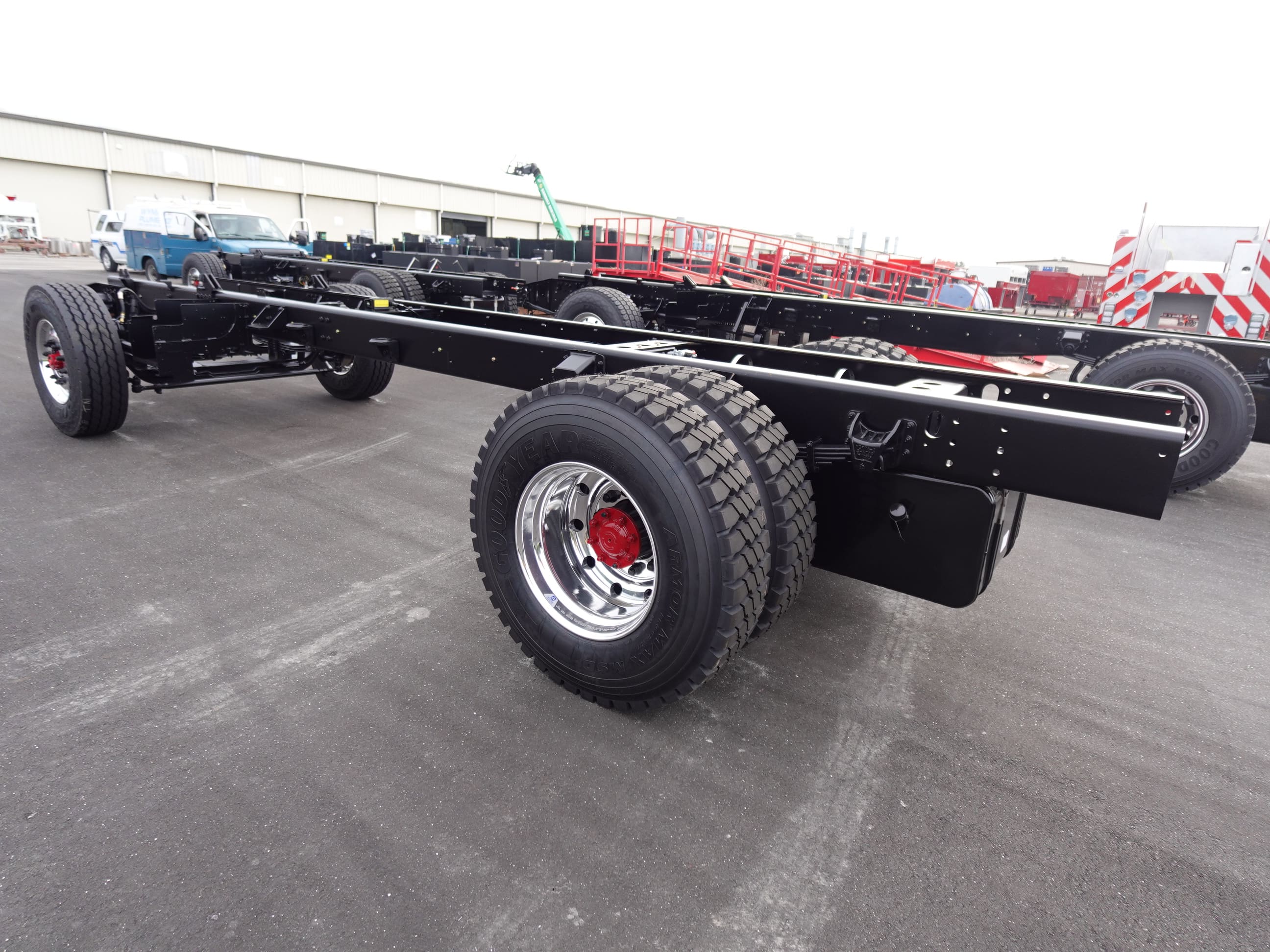

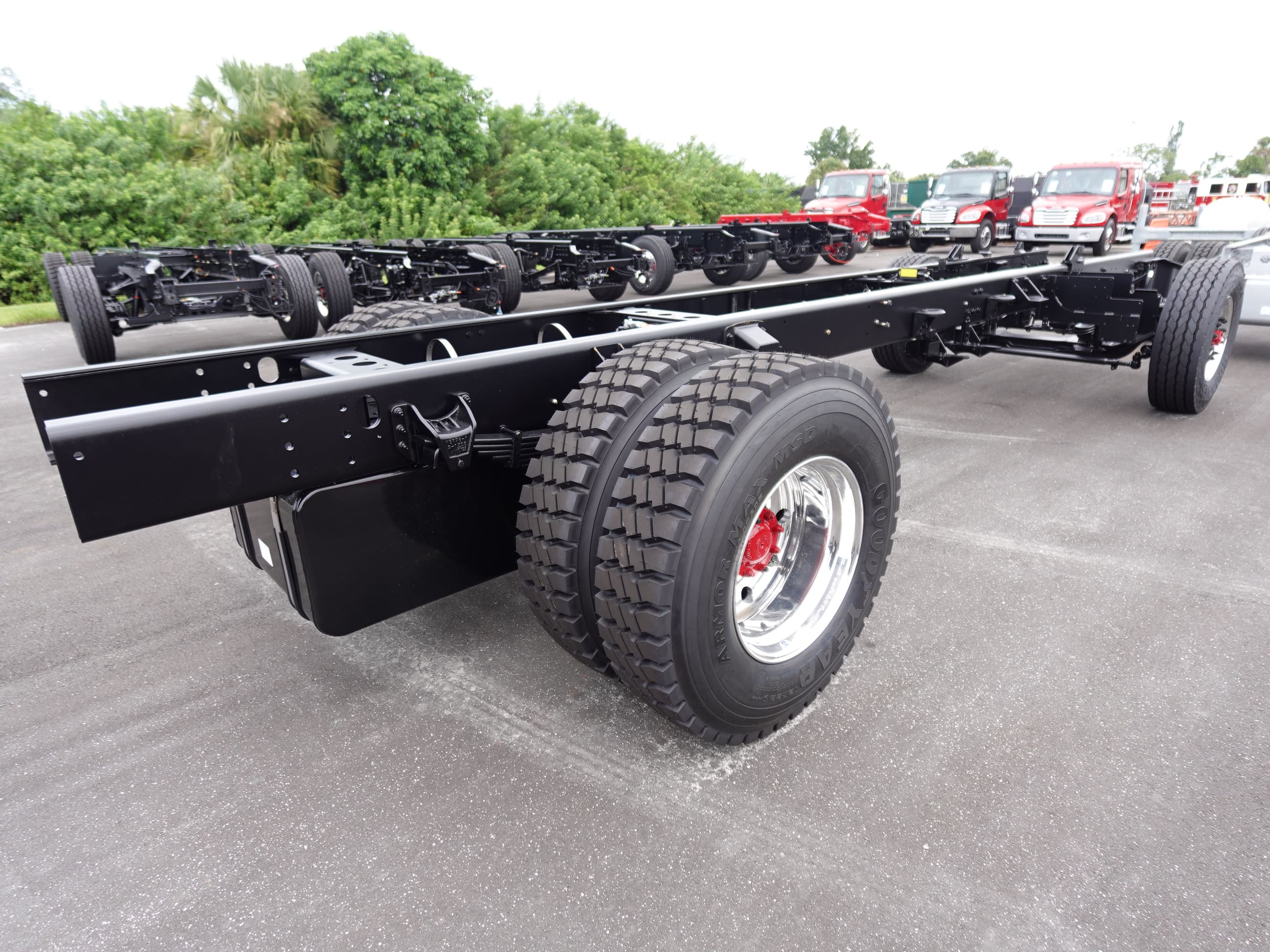

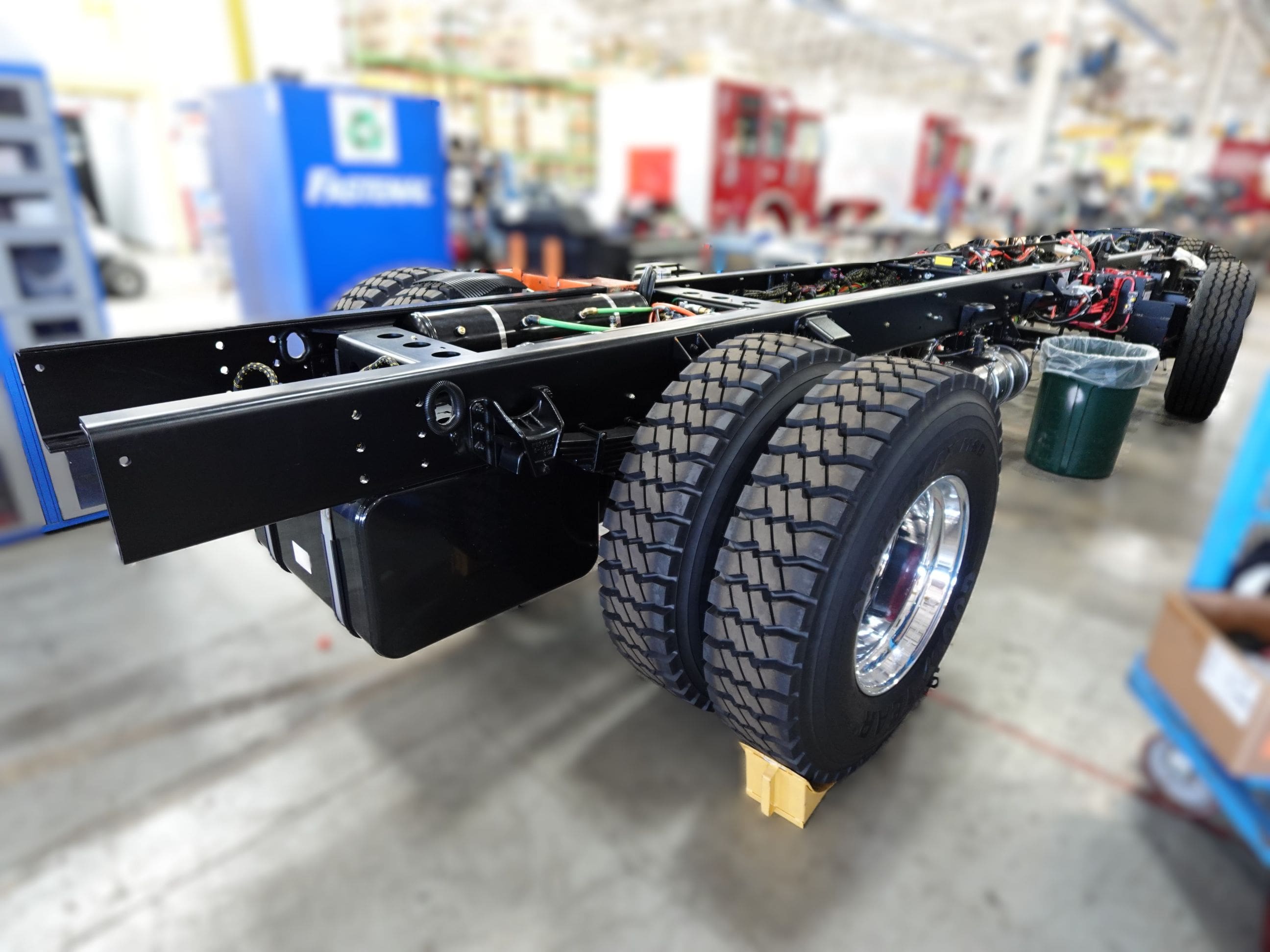

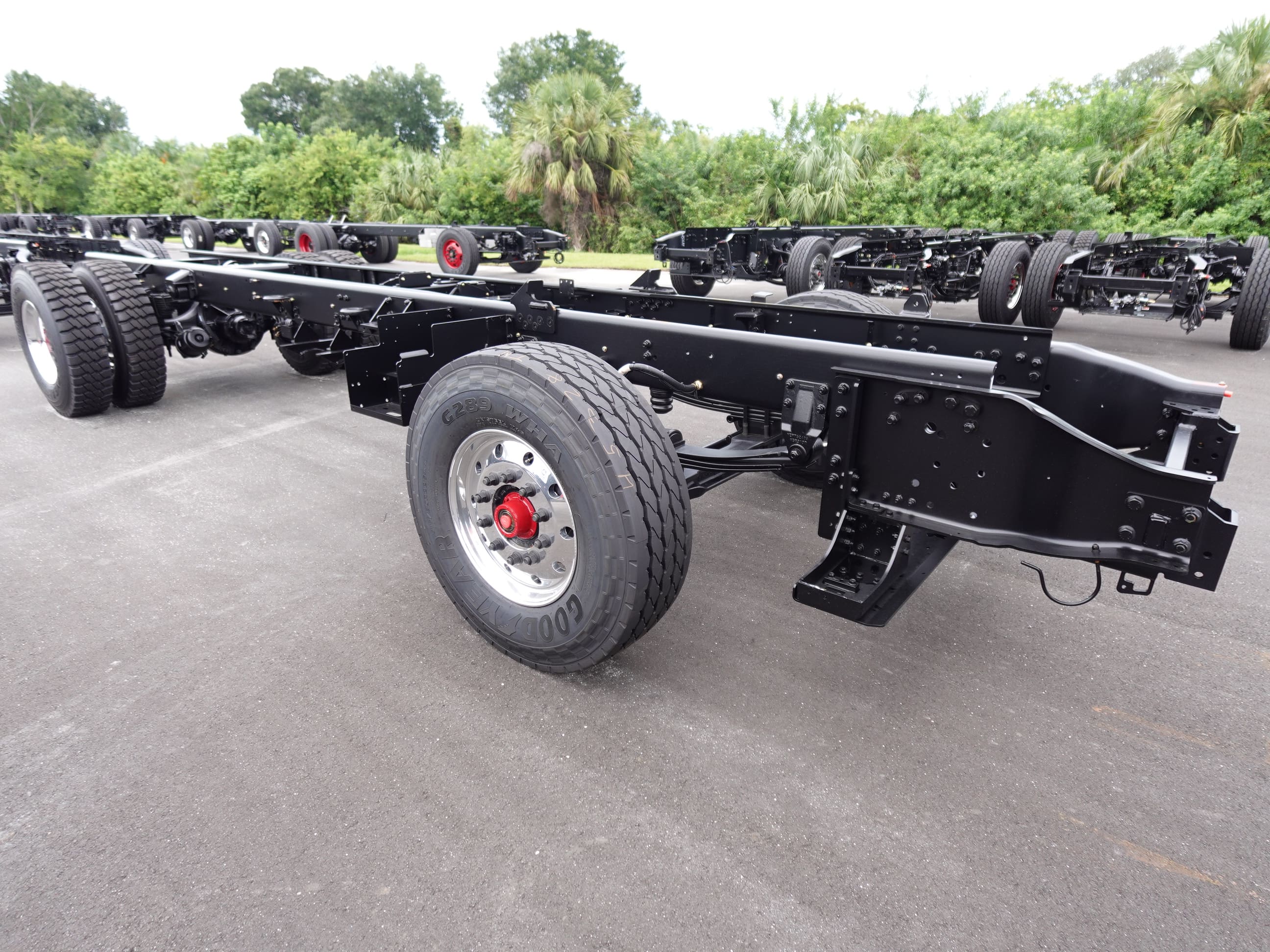

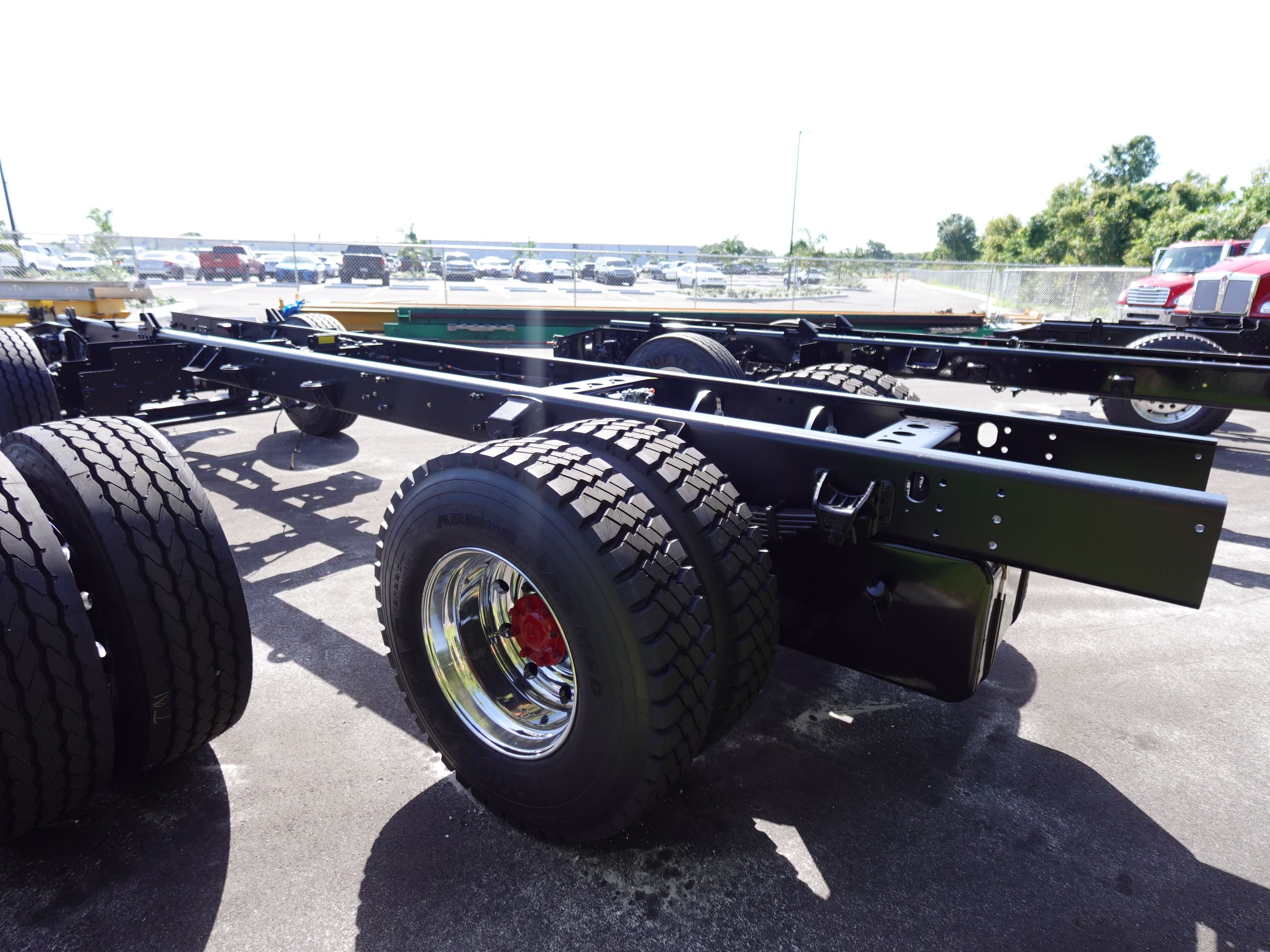

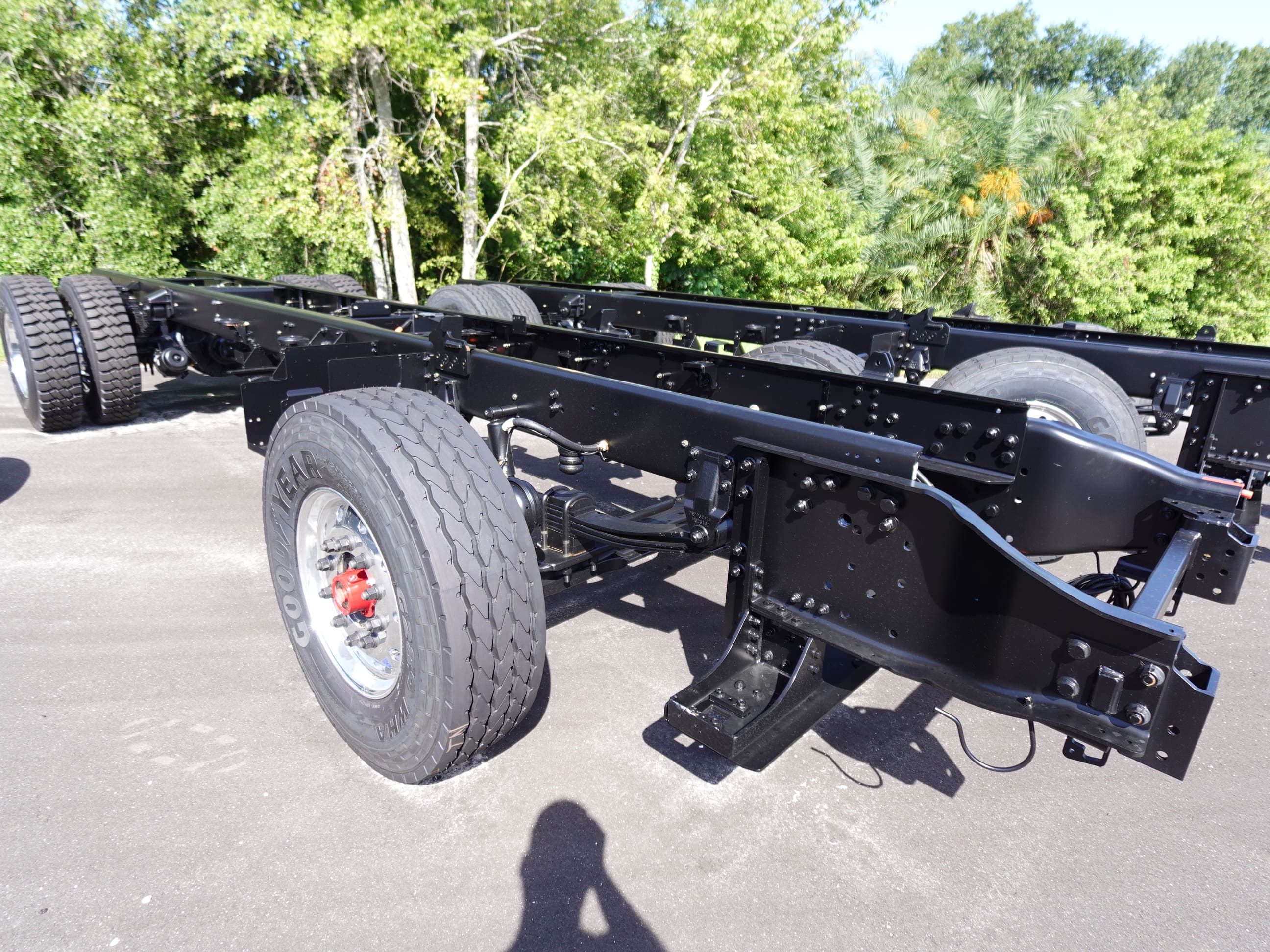

In this report, the cab was staged to begin initial assembly, the frame build began, the pump house continued initial assembly, and the body remained staged.

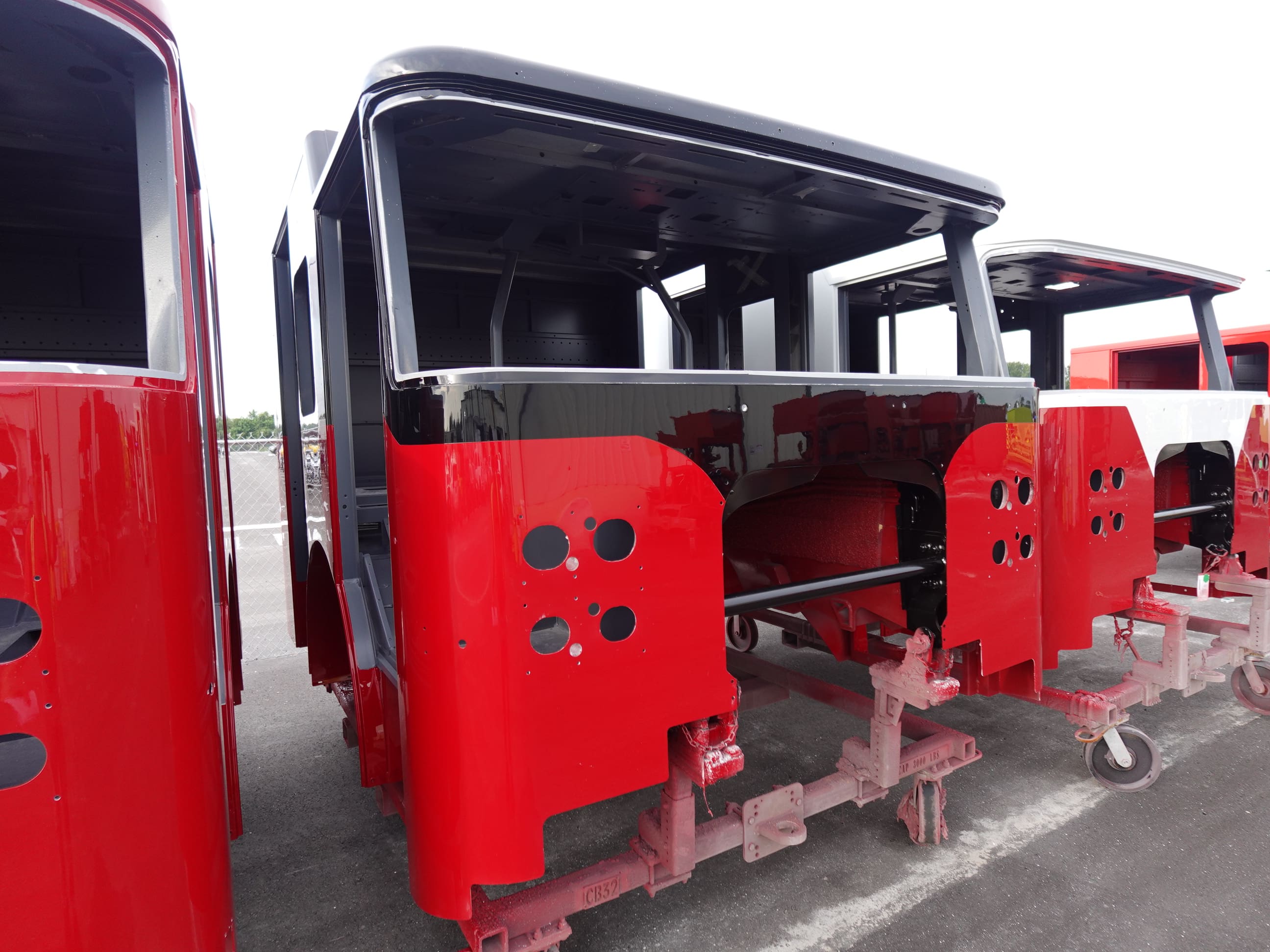

07-24-26

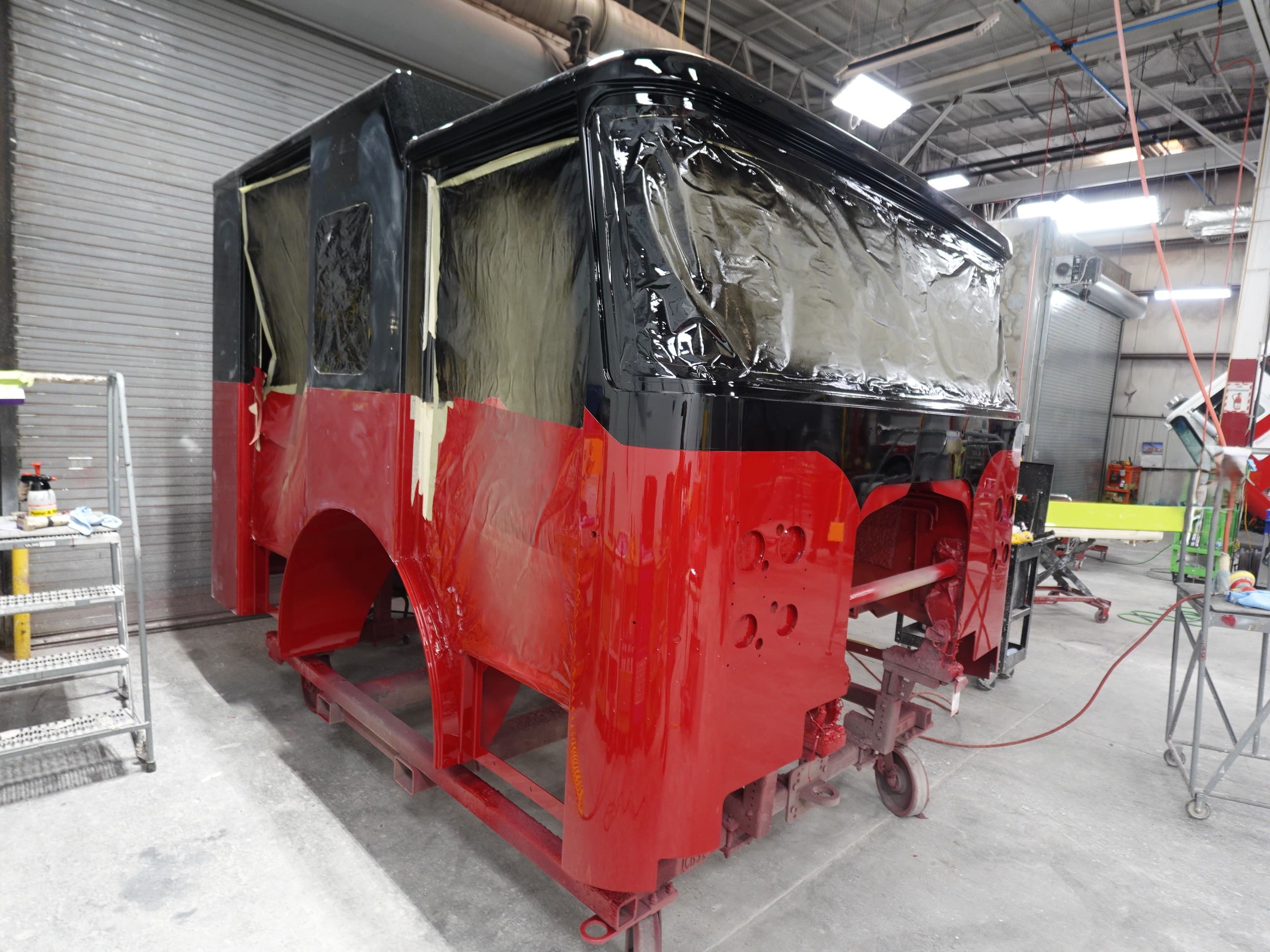

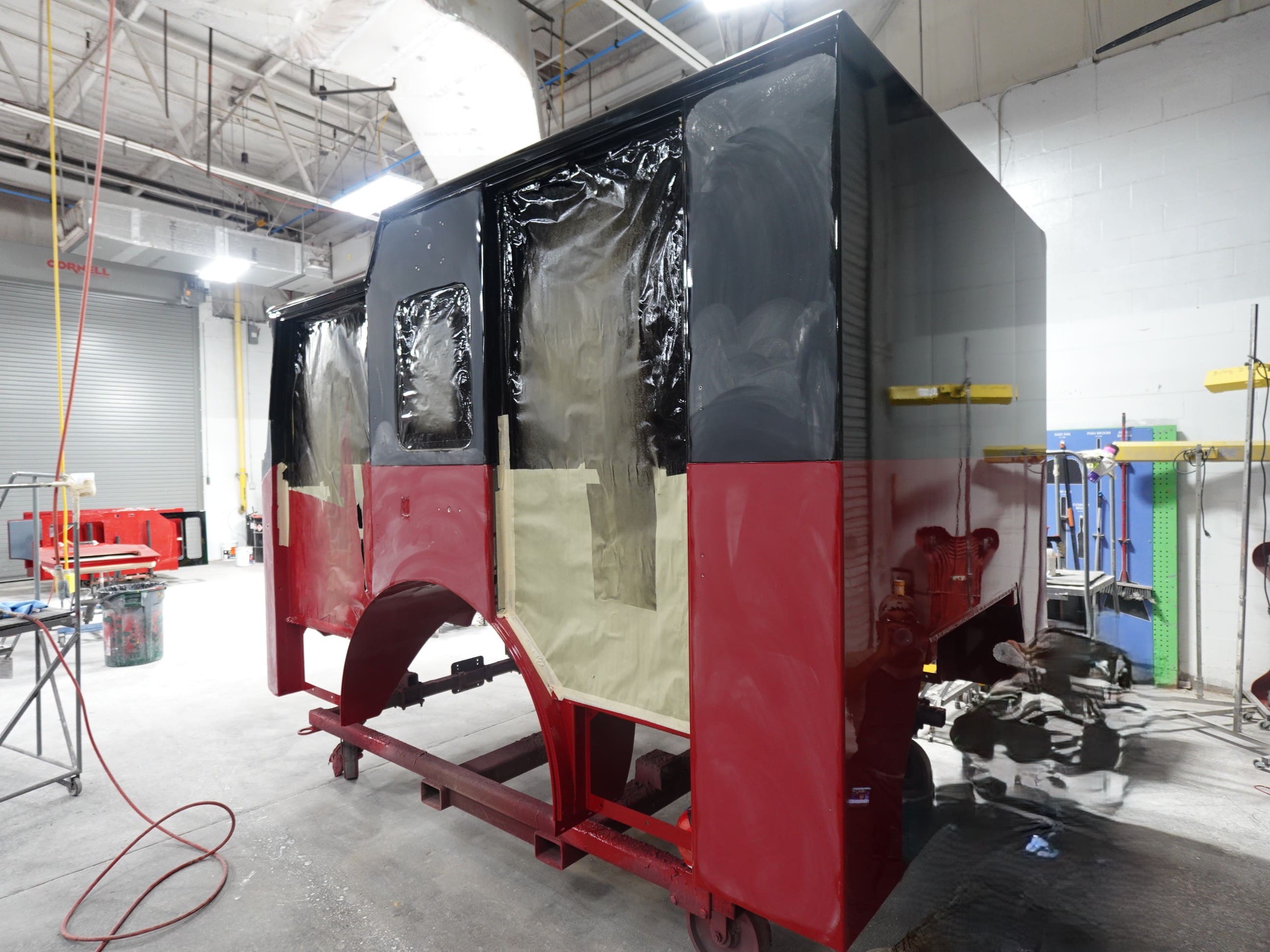

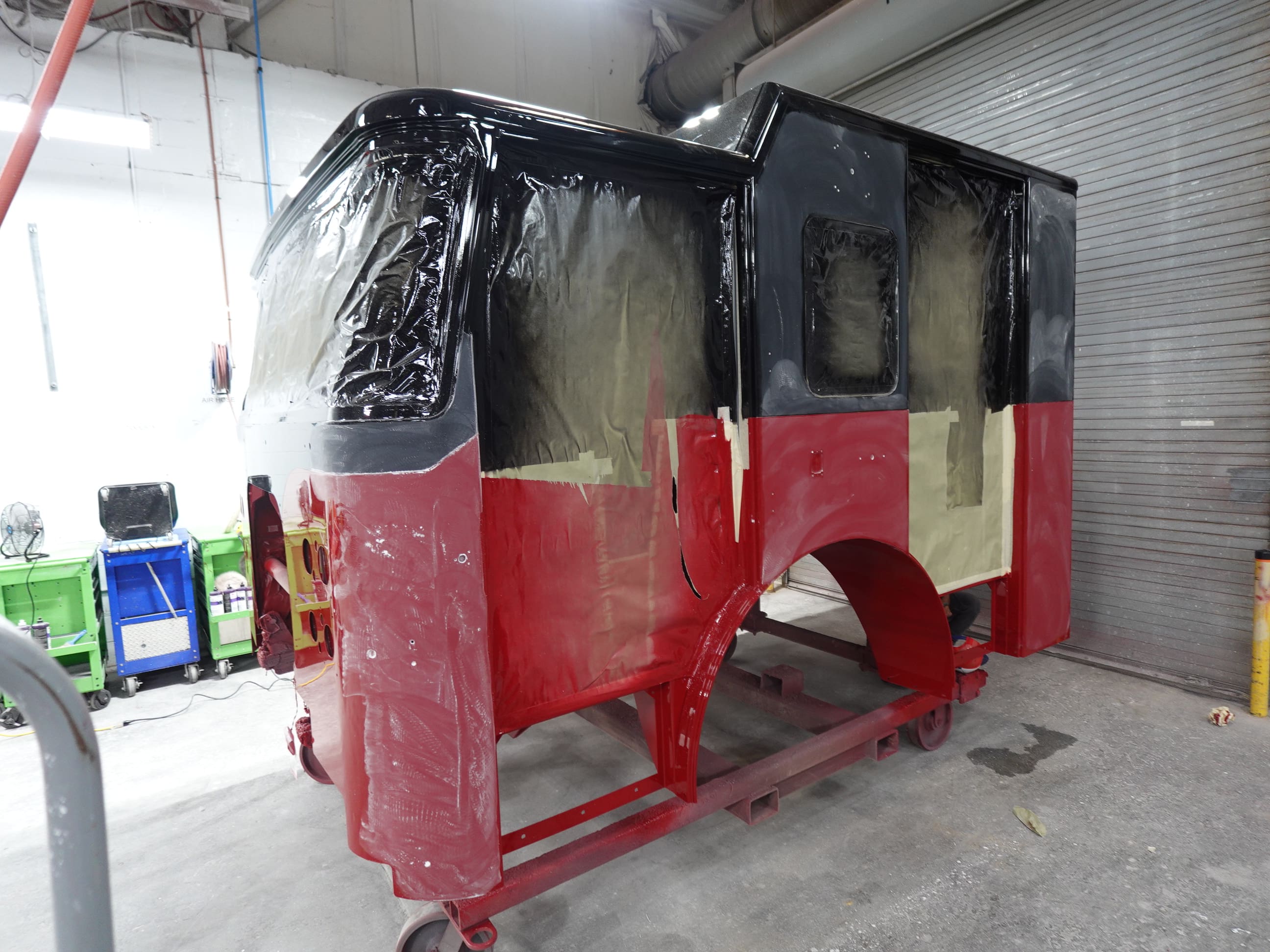

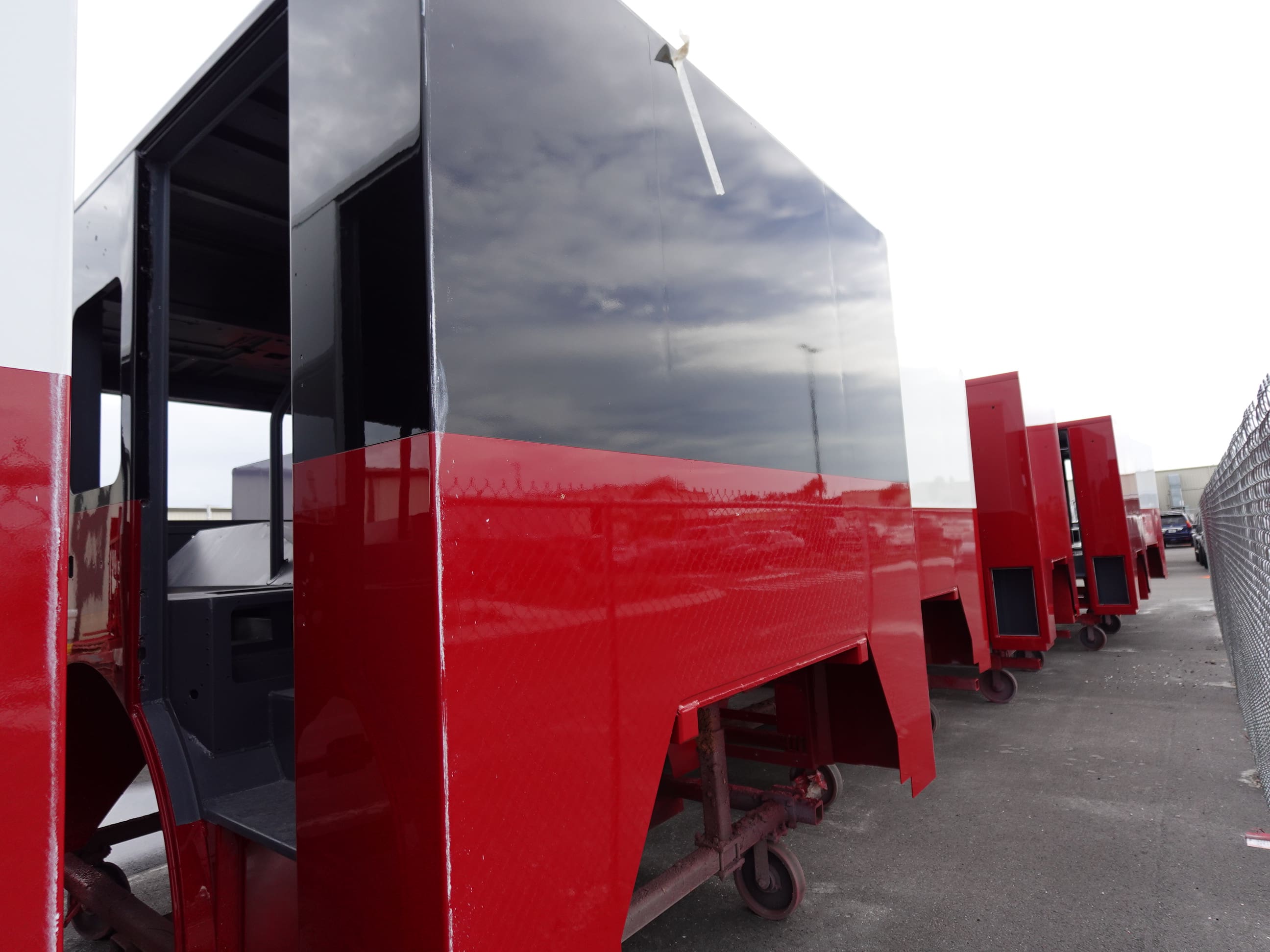

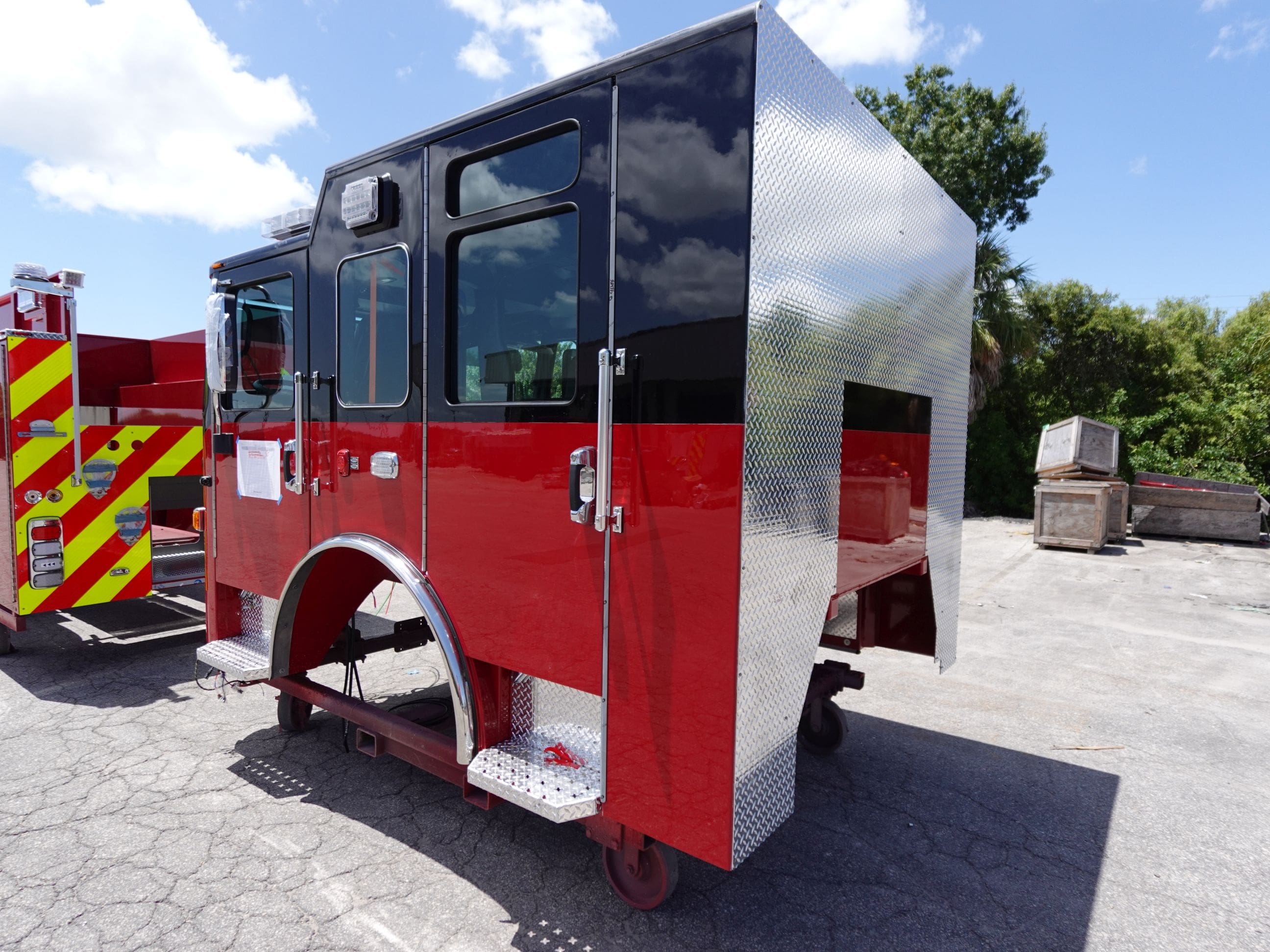

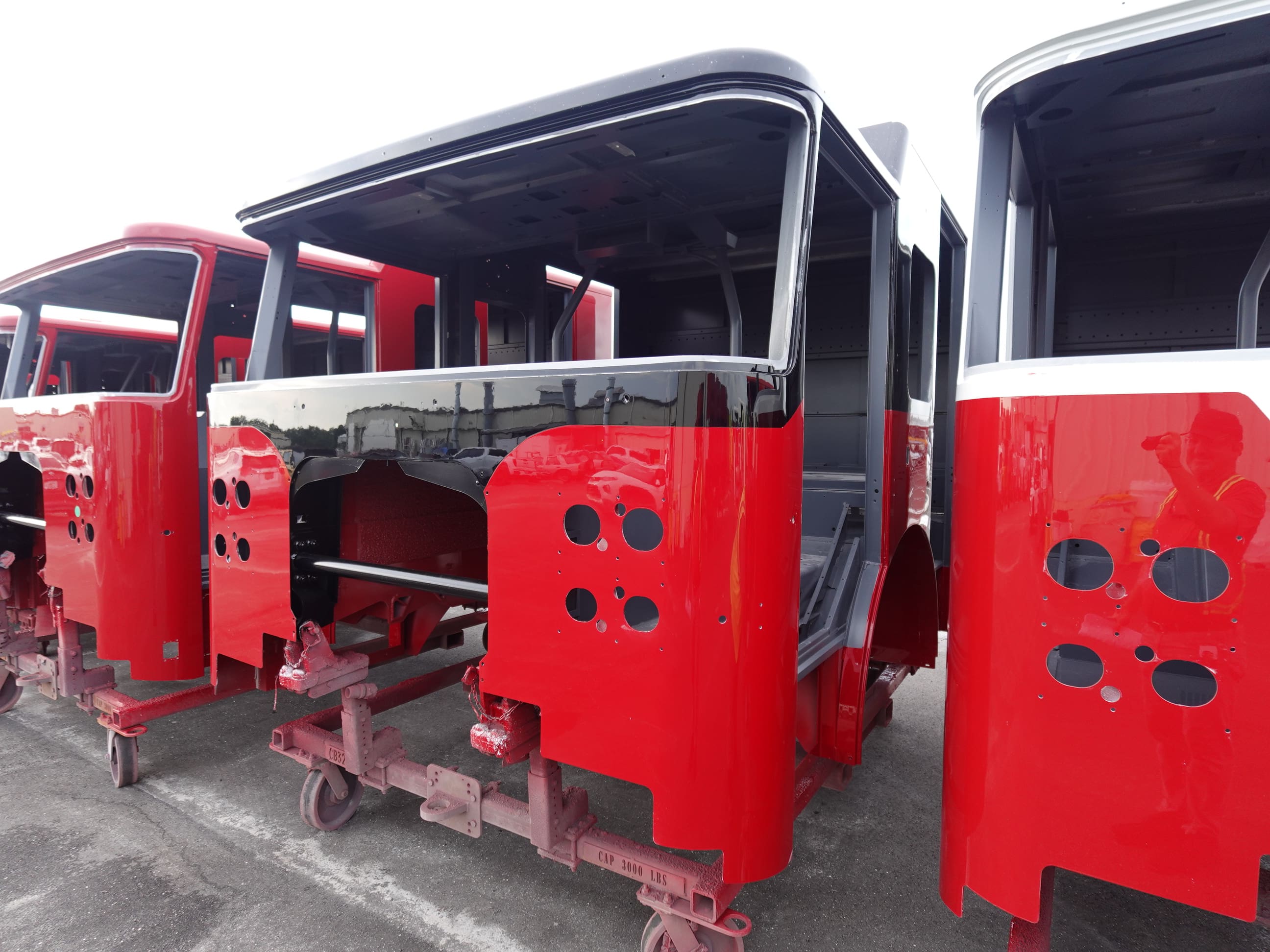

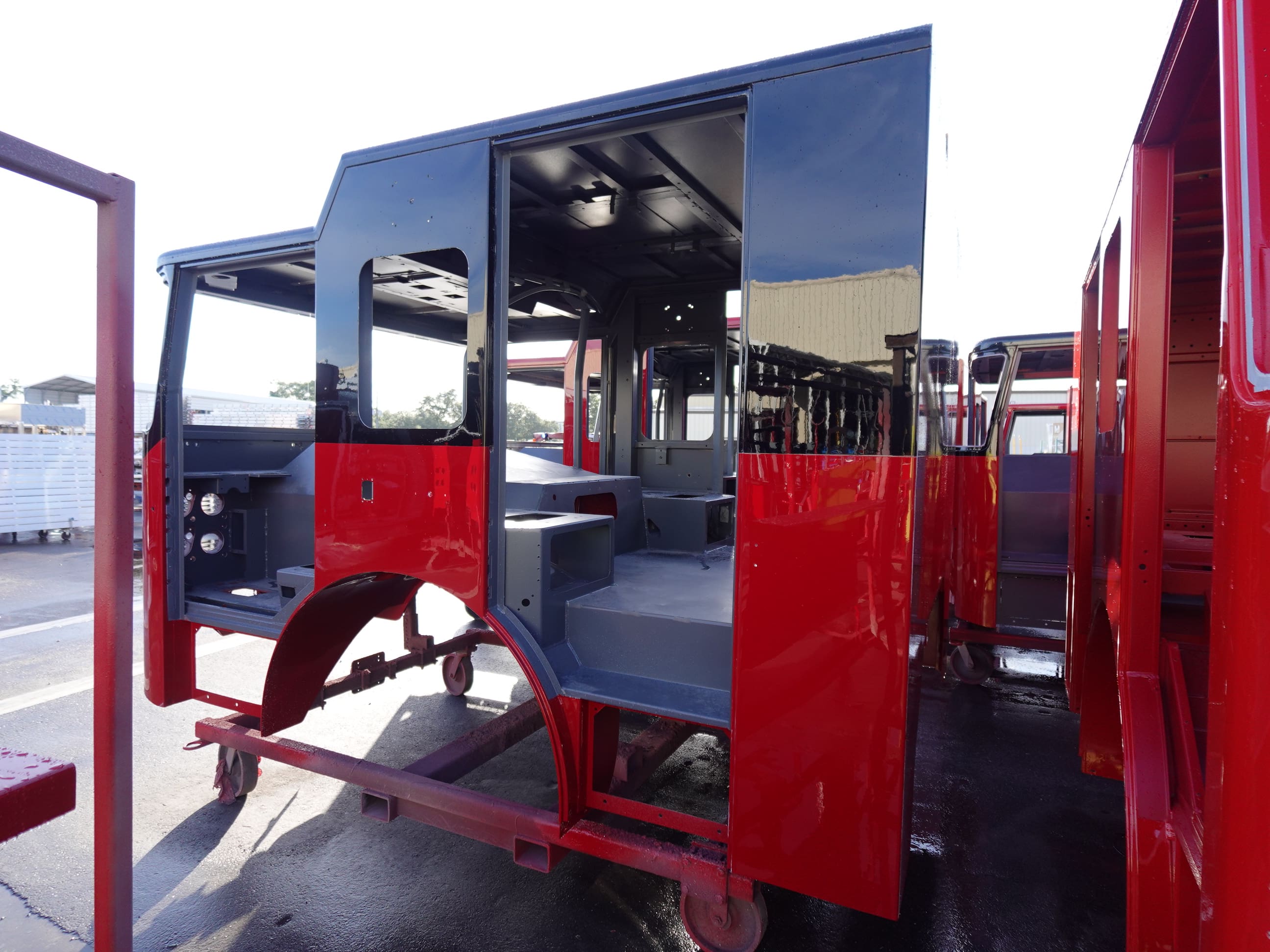

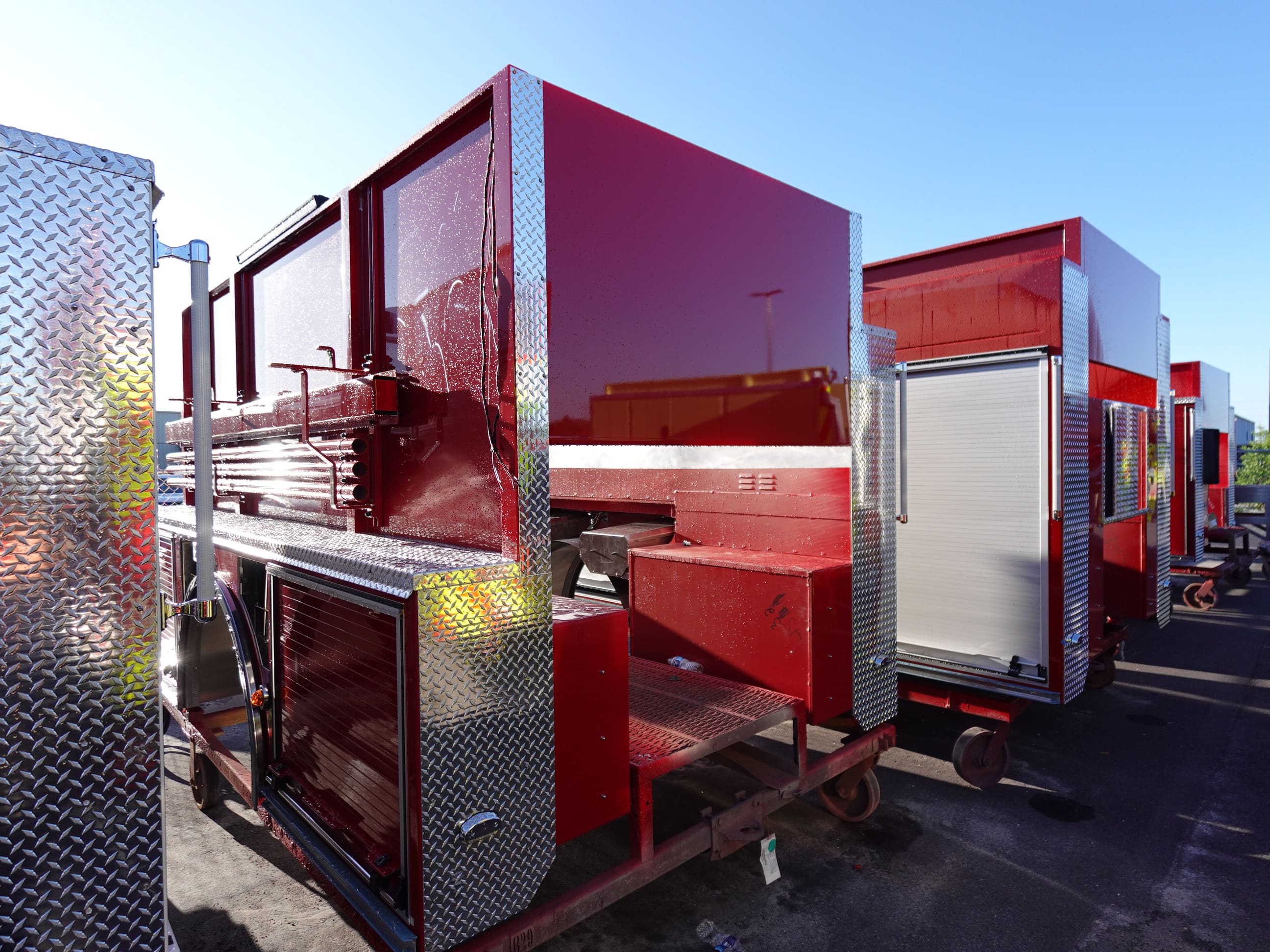

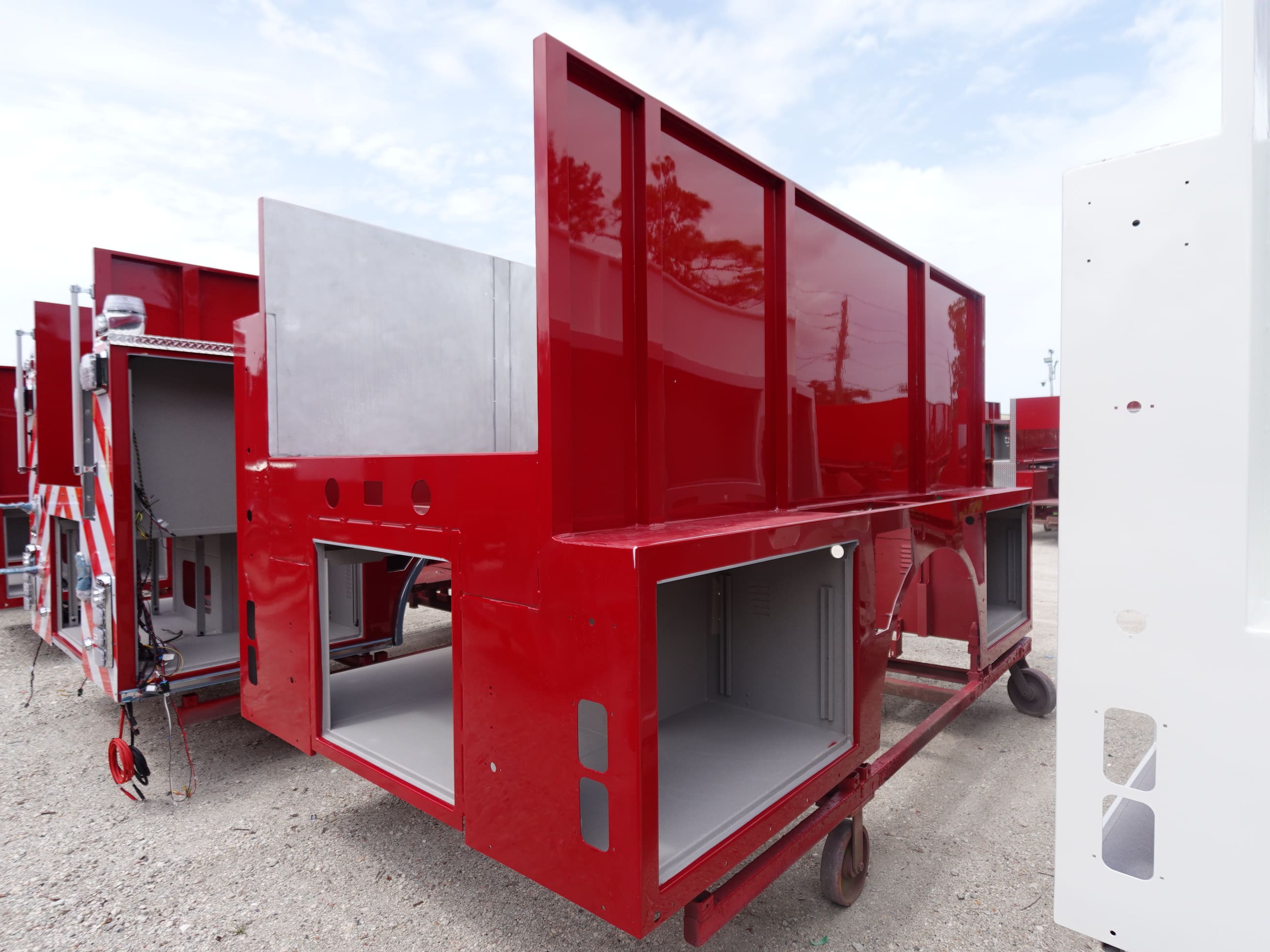

In this report, the cab completed the paint process, the
pump house was painted then staged to continue initial
assembly, and the body was staged.
07-17-26

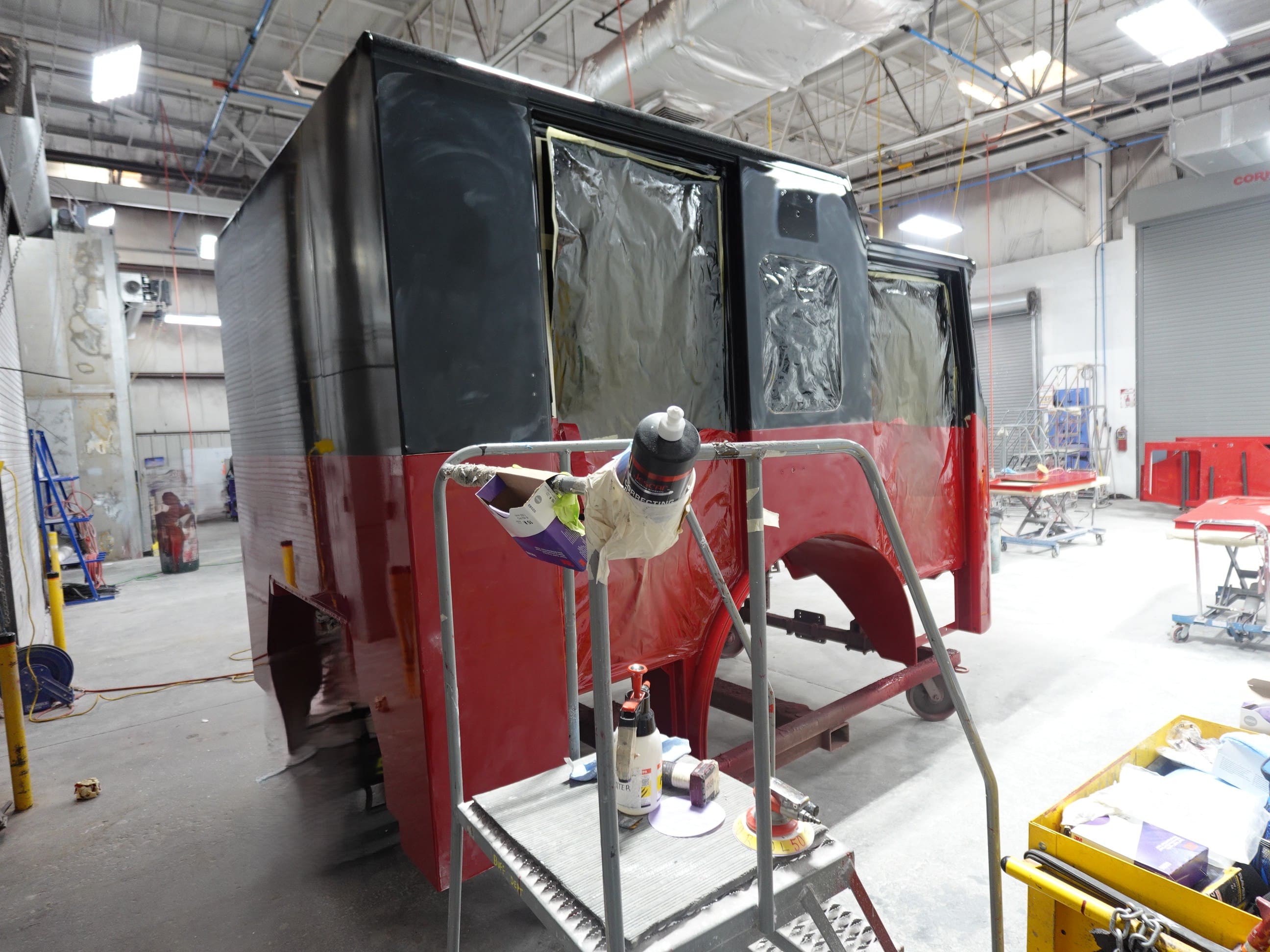

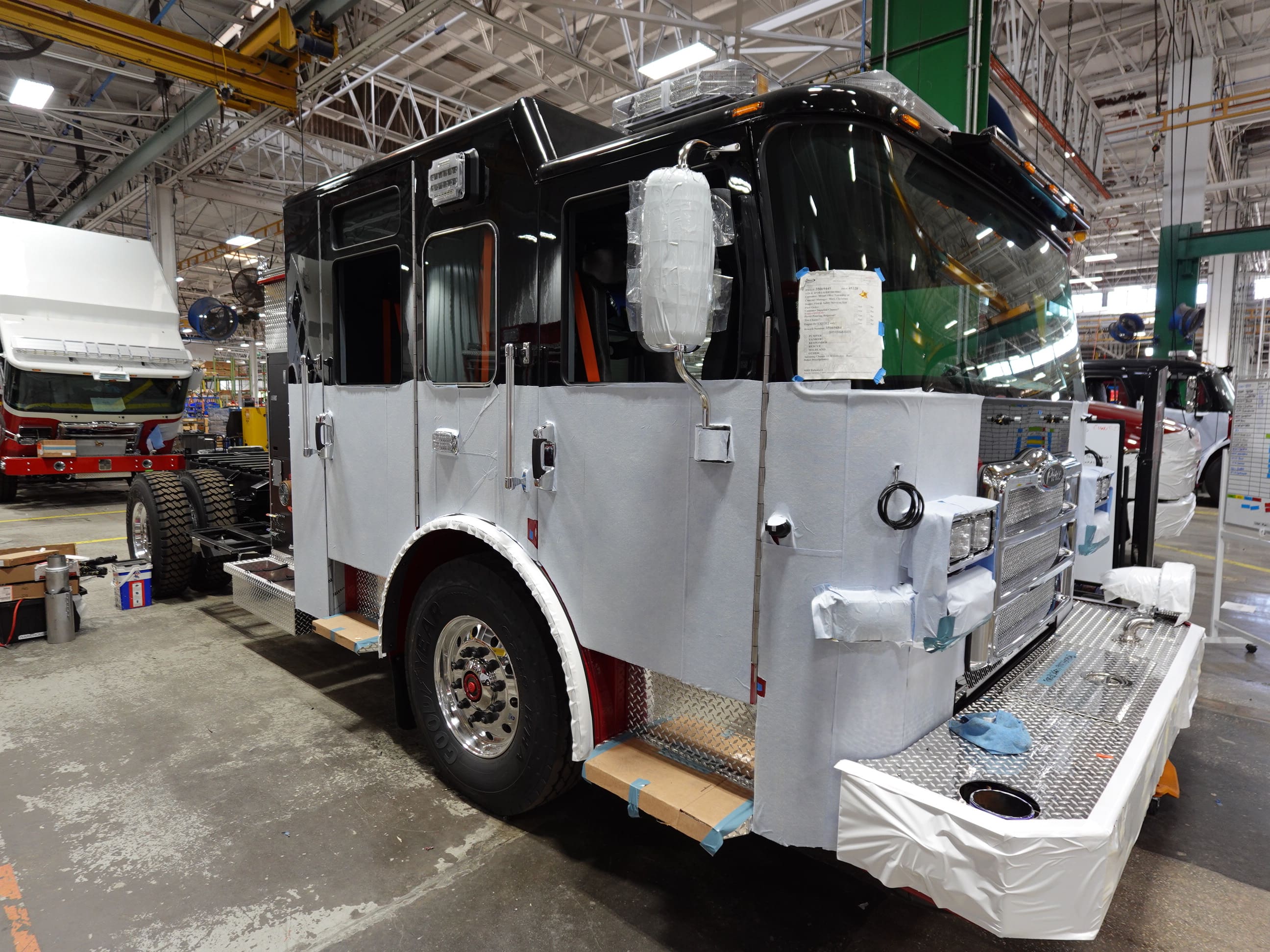

In this report, the cab began the paint process, the pump

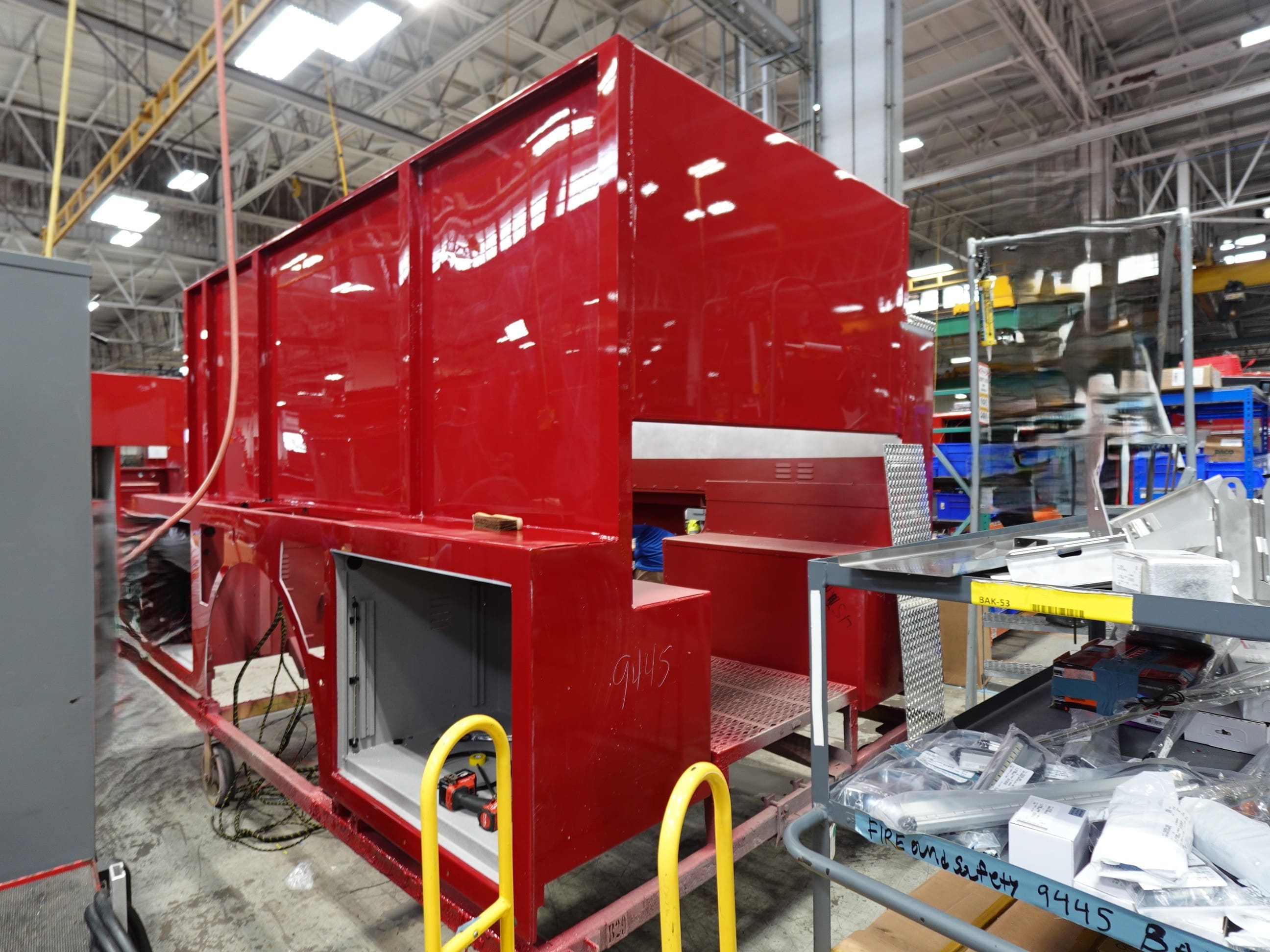

house continued initial assembly, and the body completed
the paint process.
06-26-26

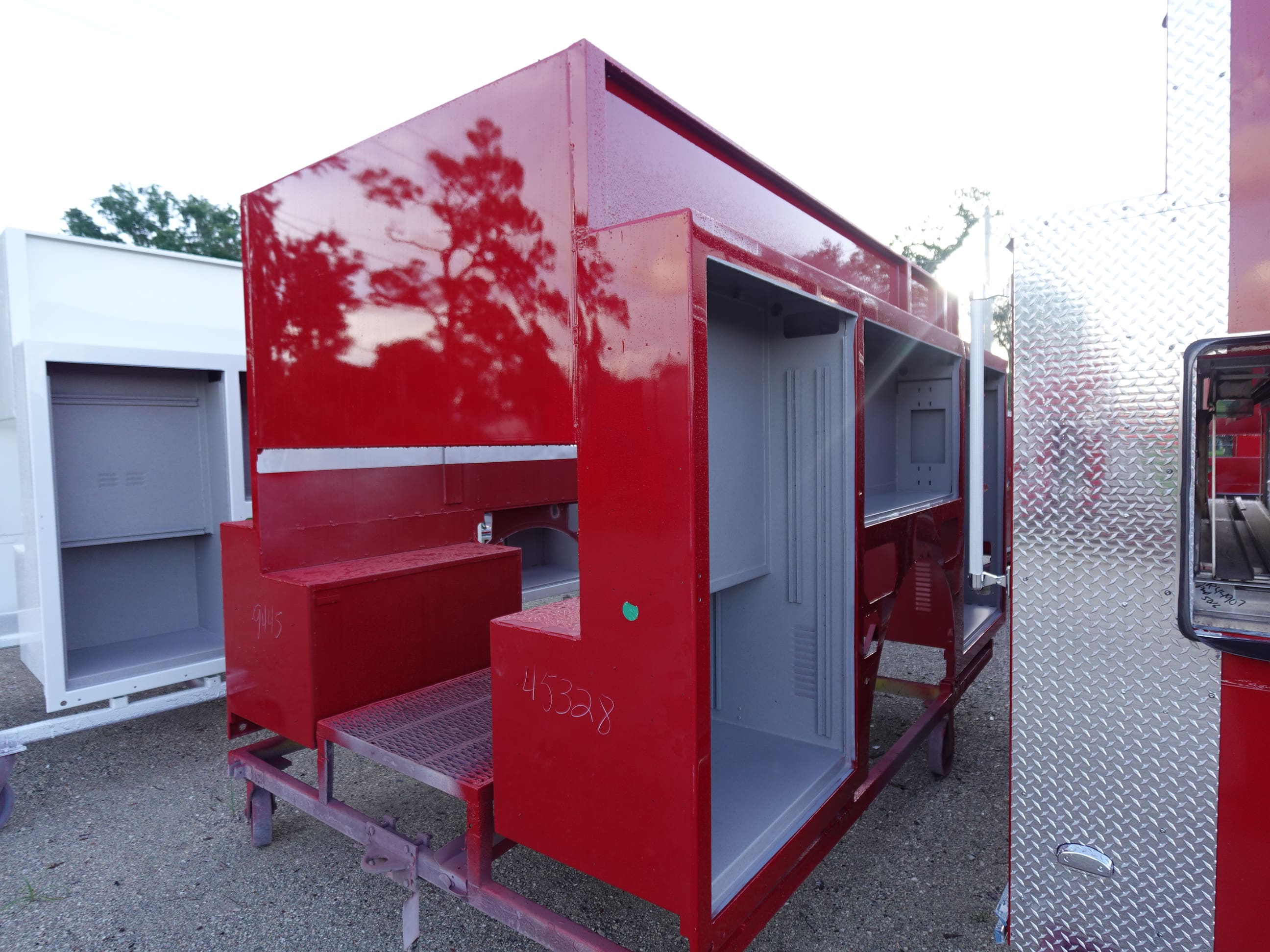

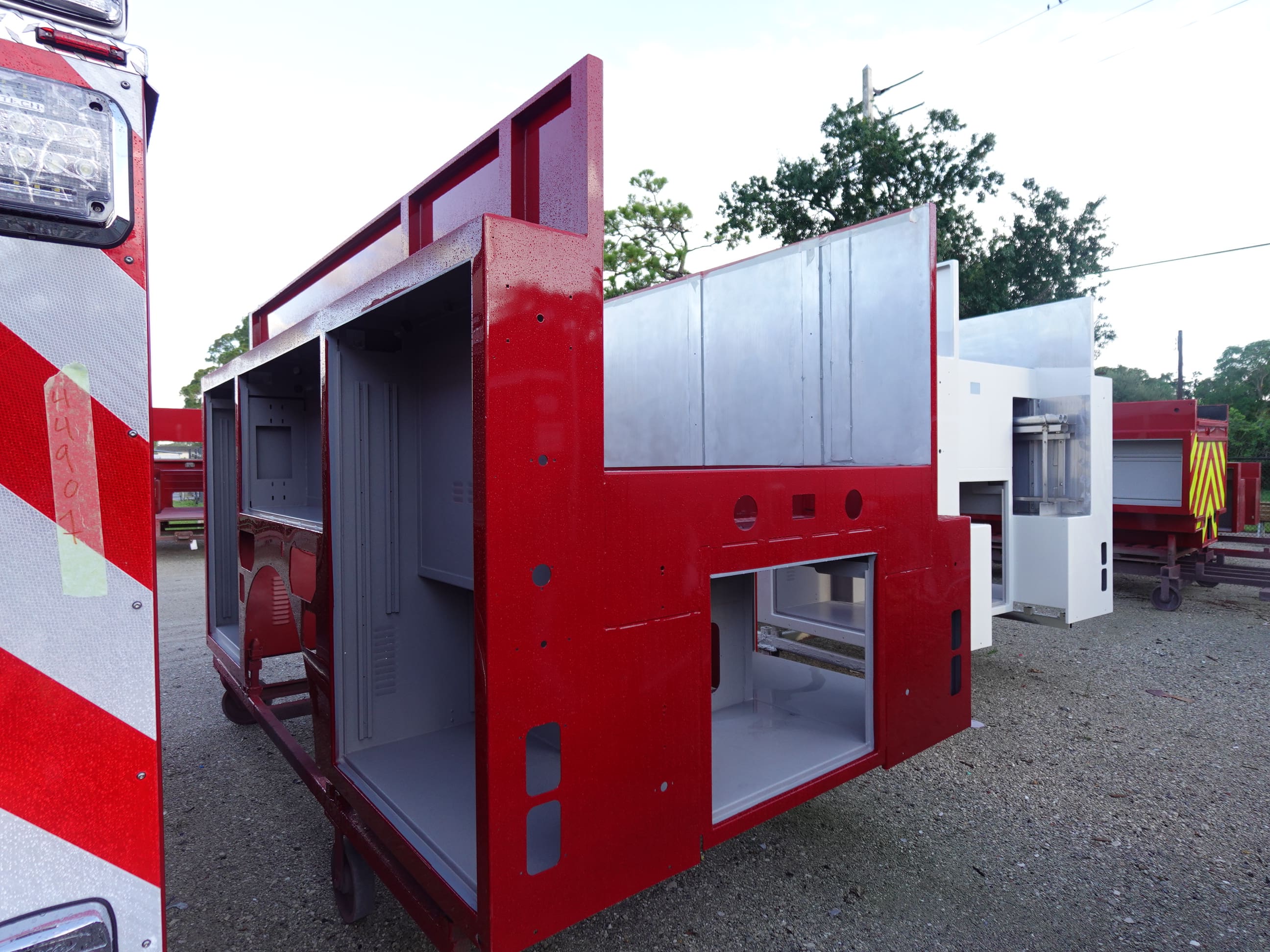

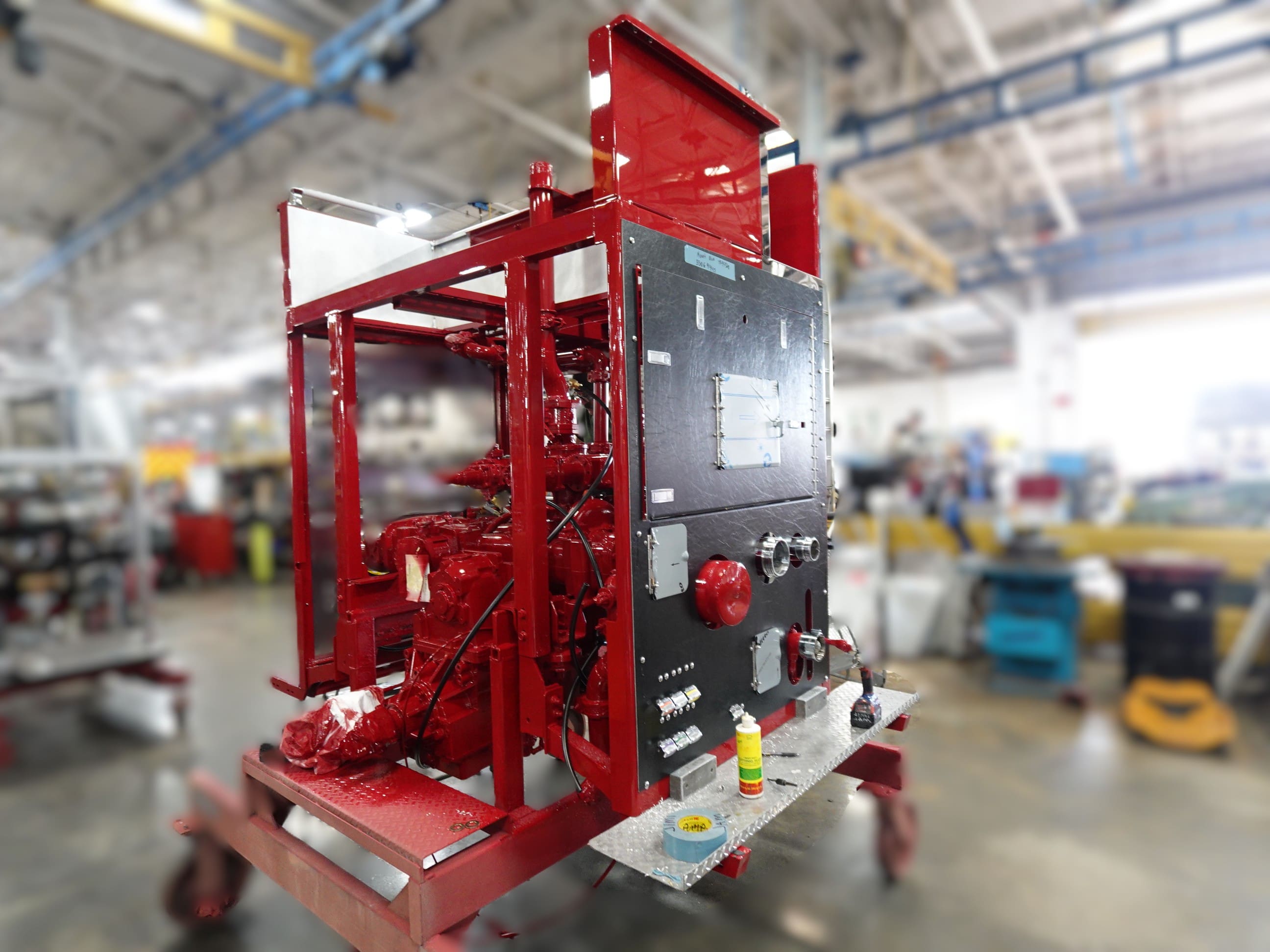

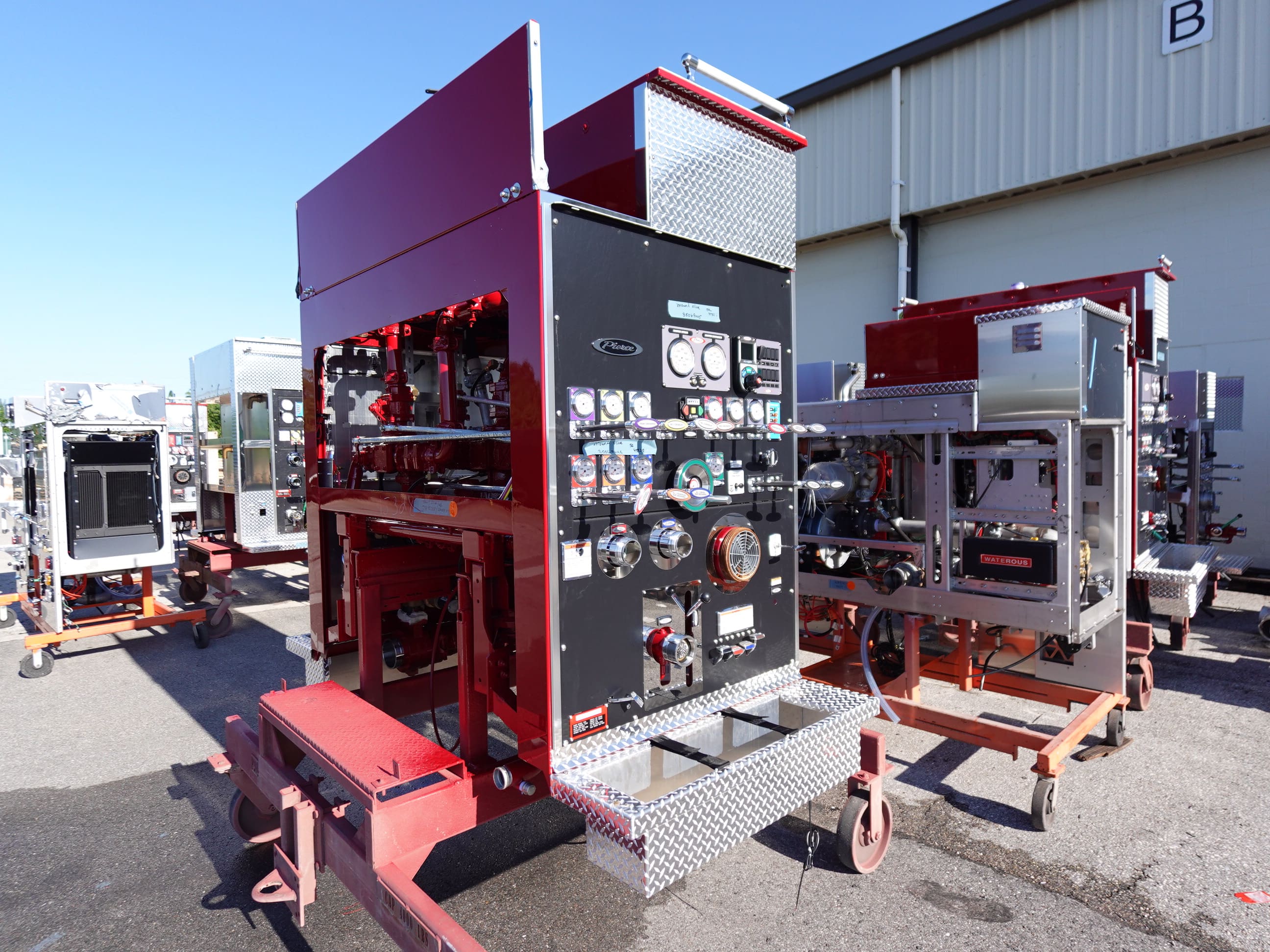

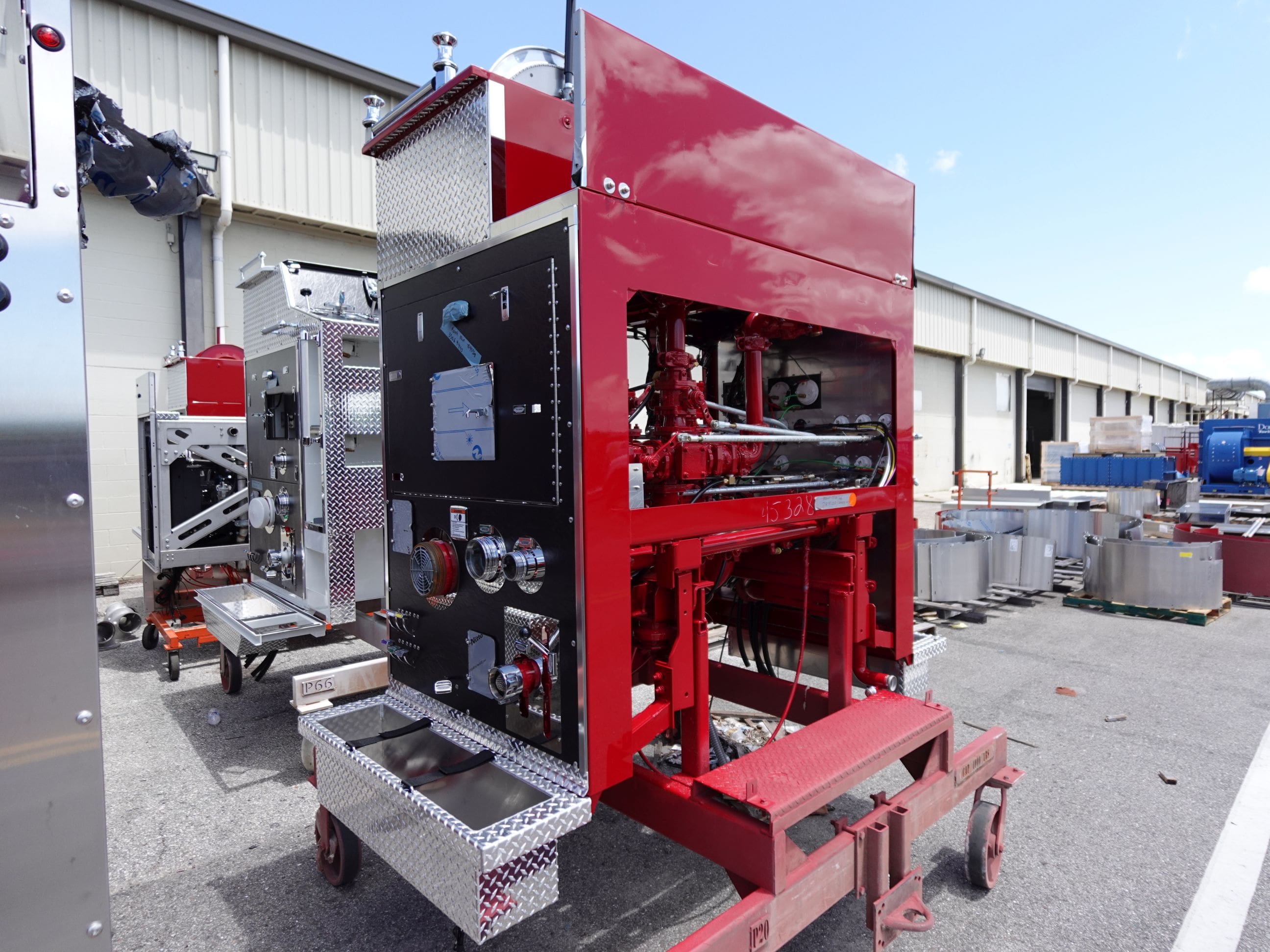

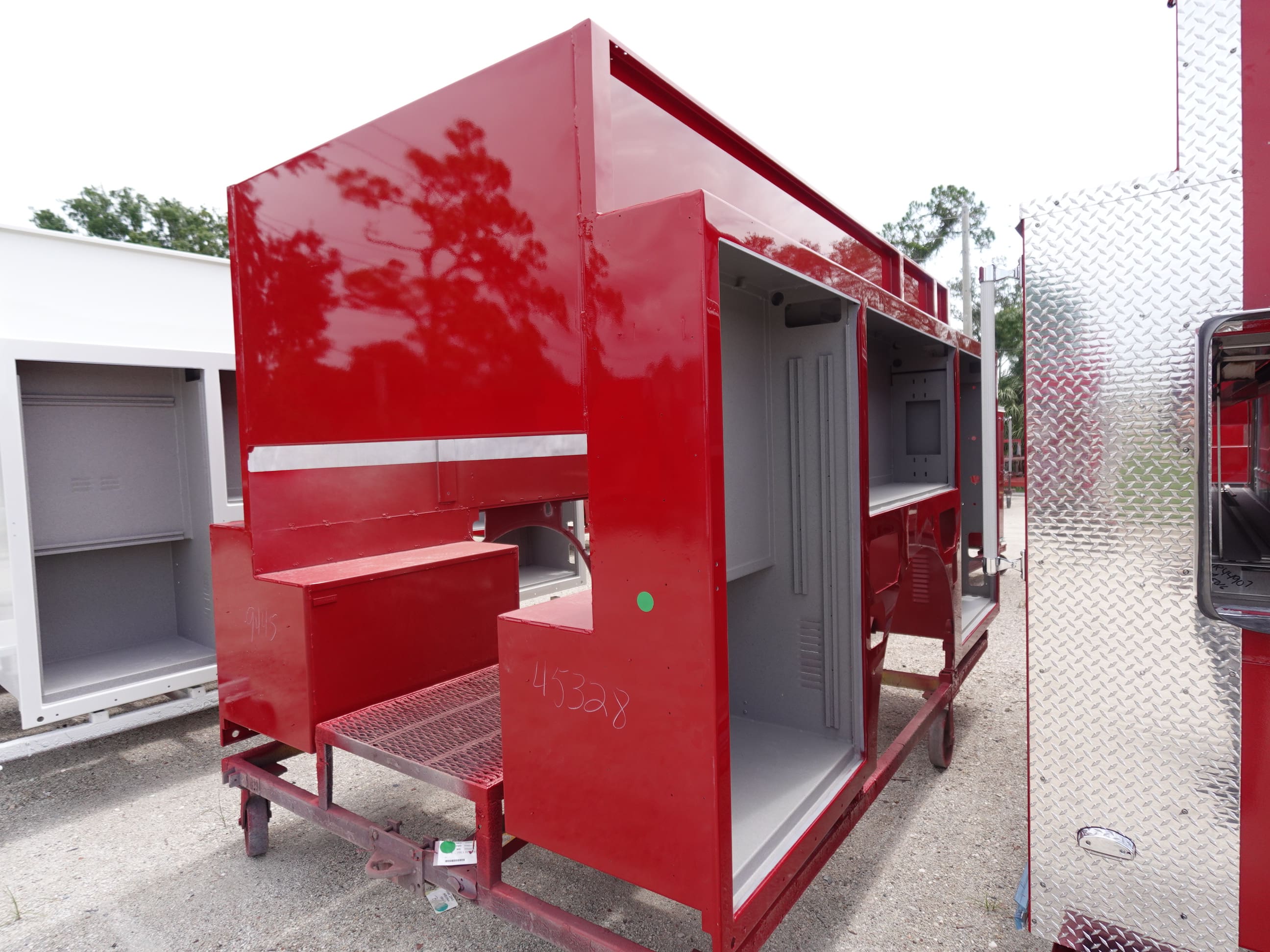

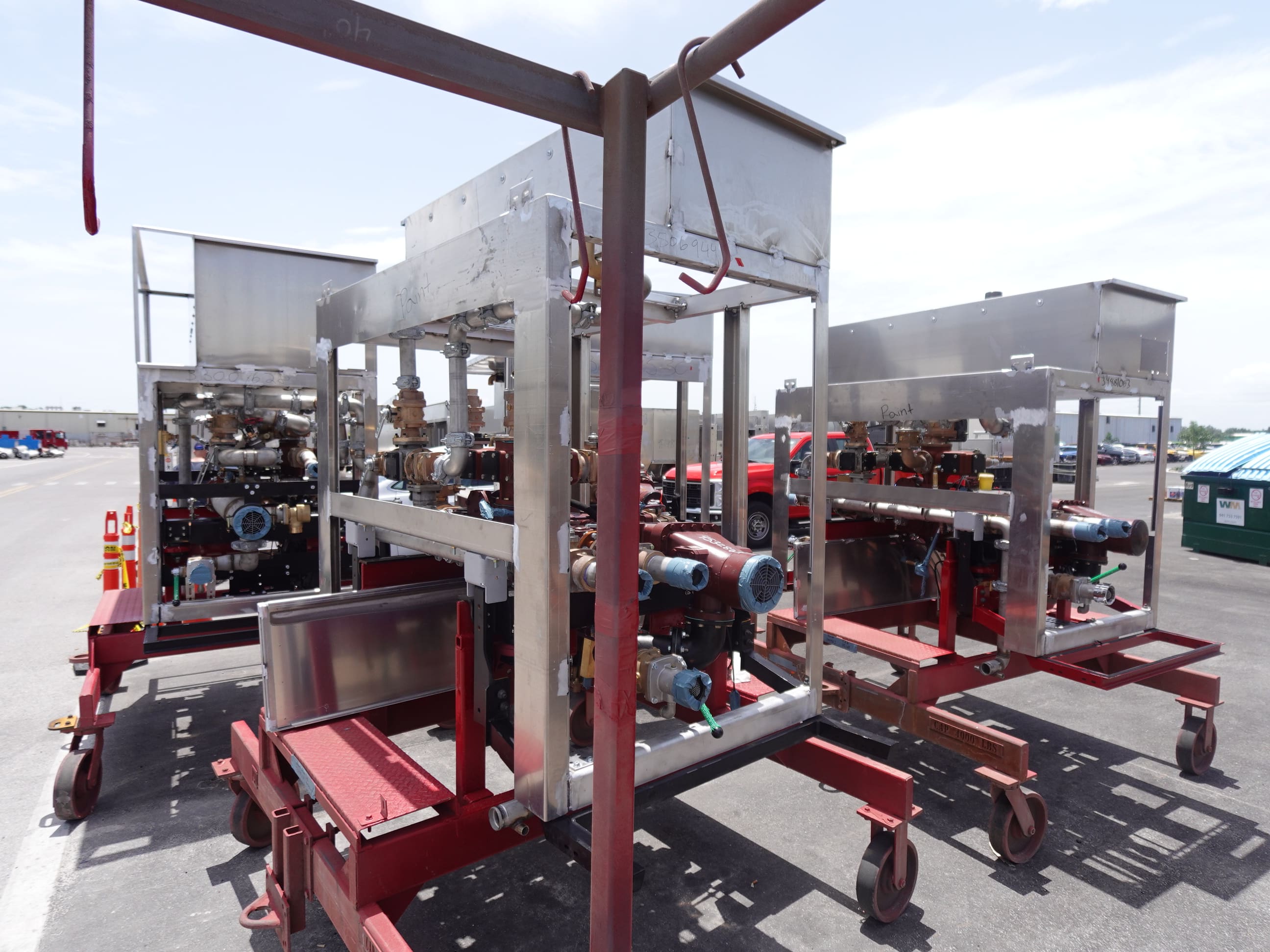

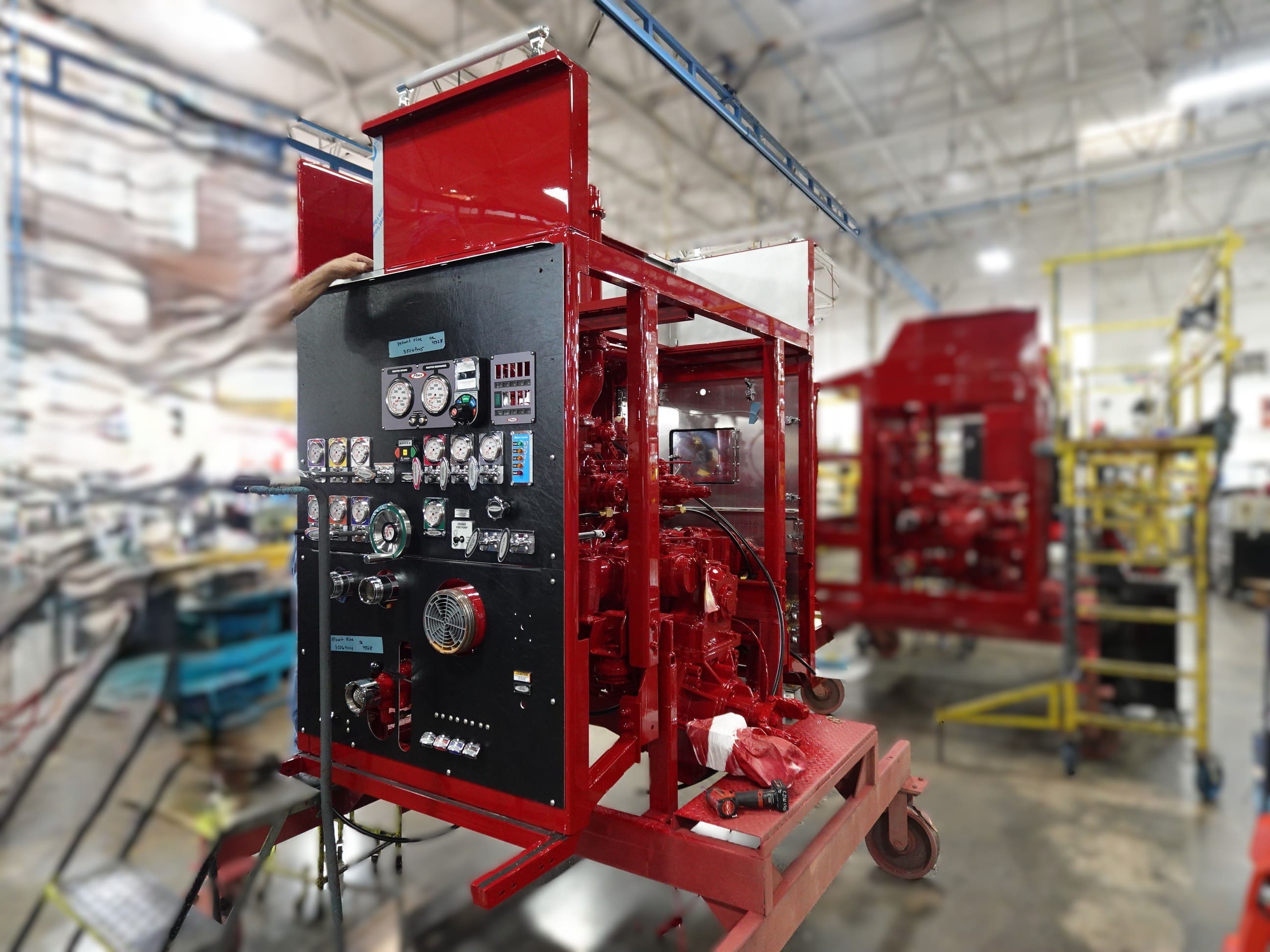

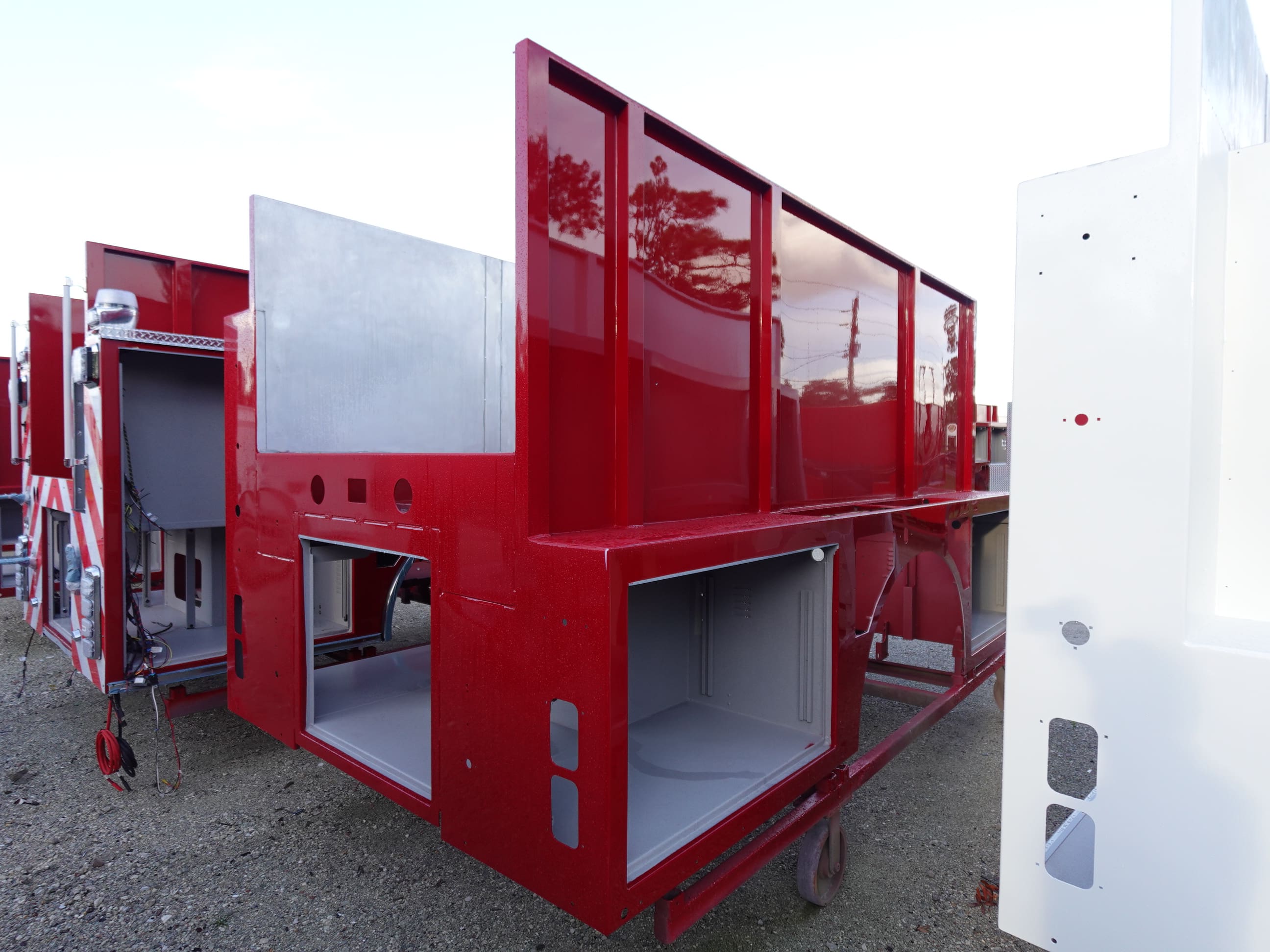

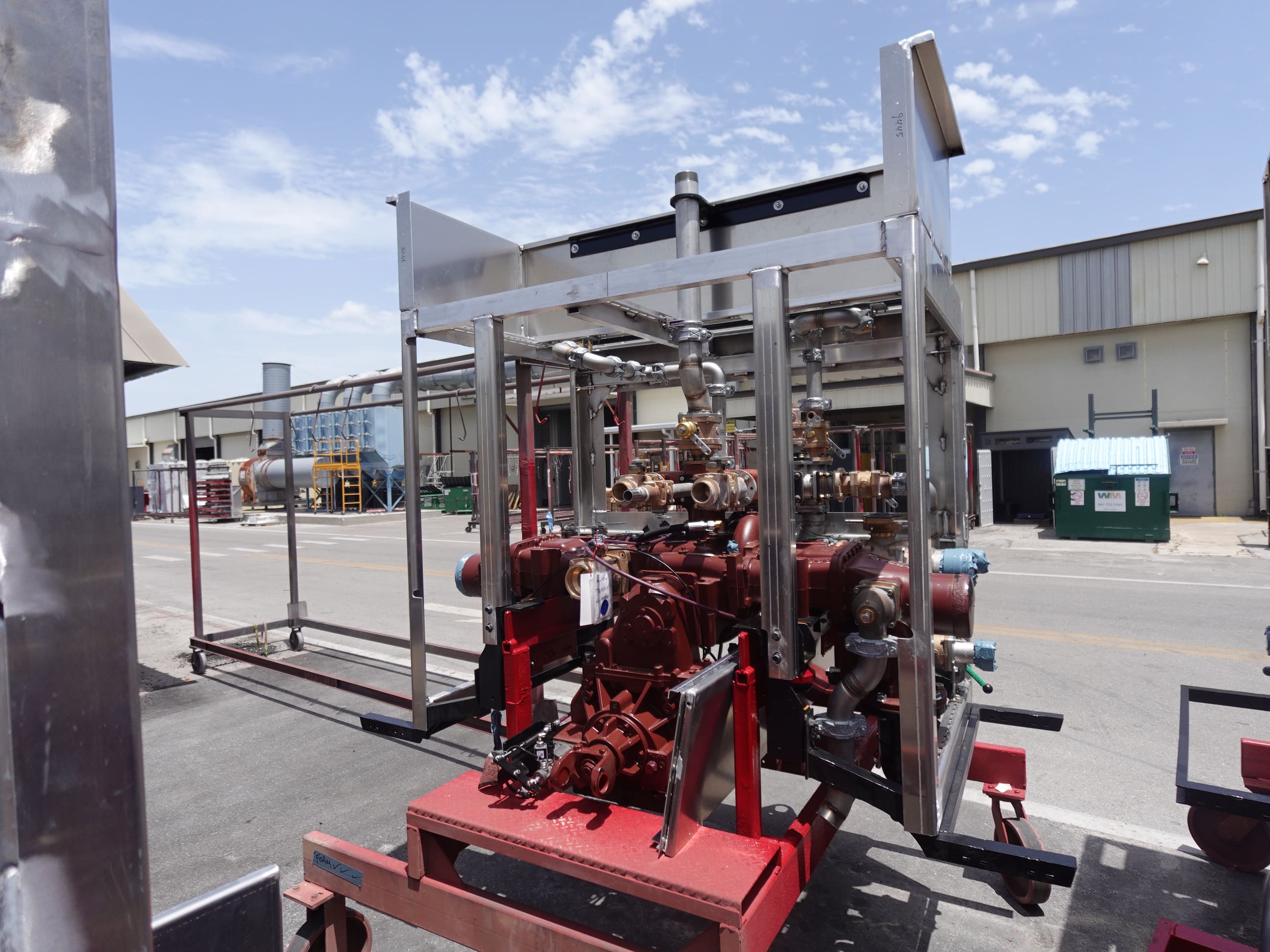

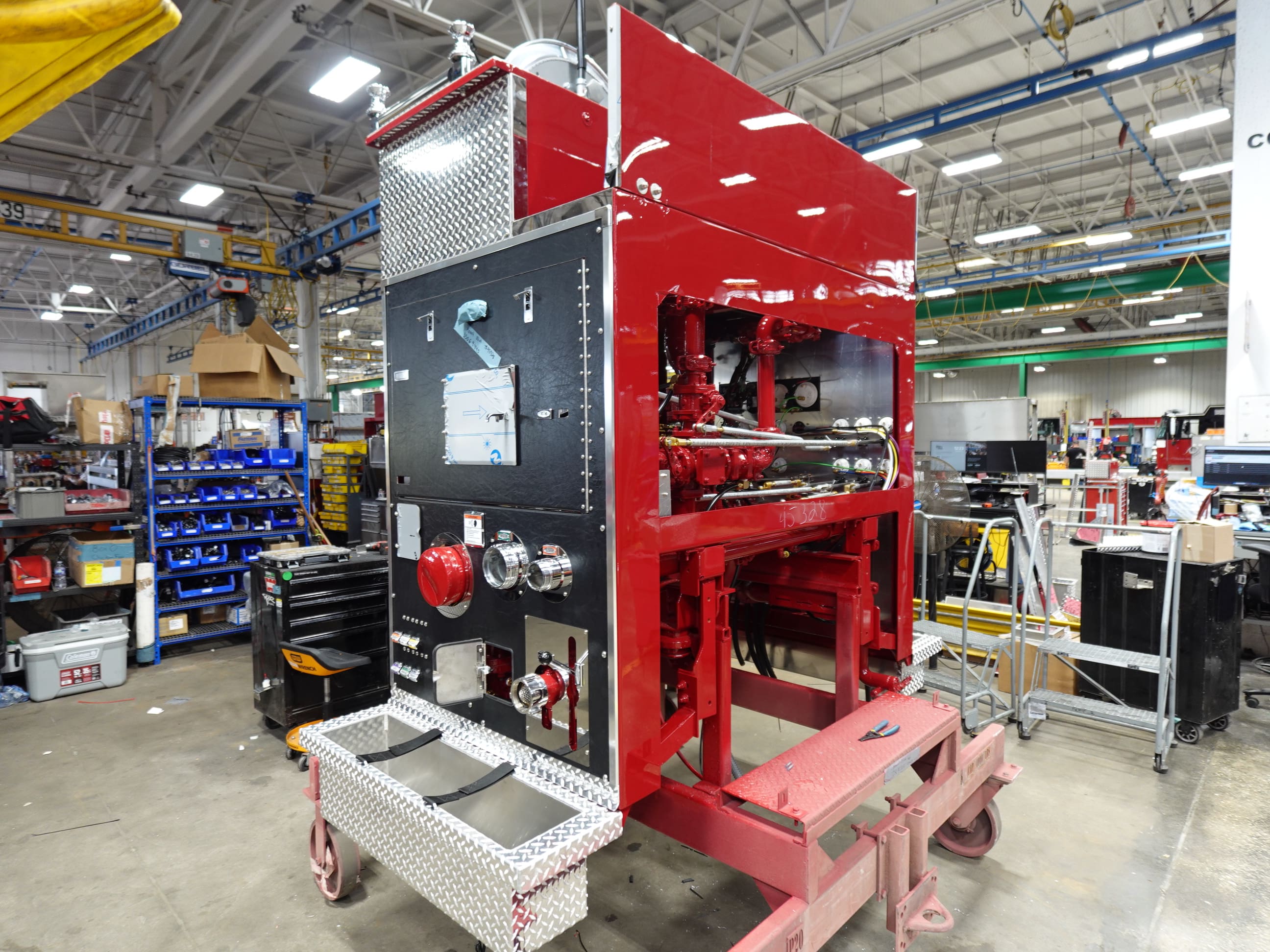

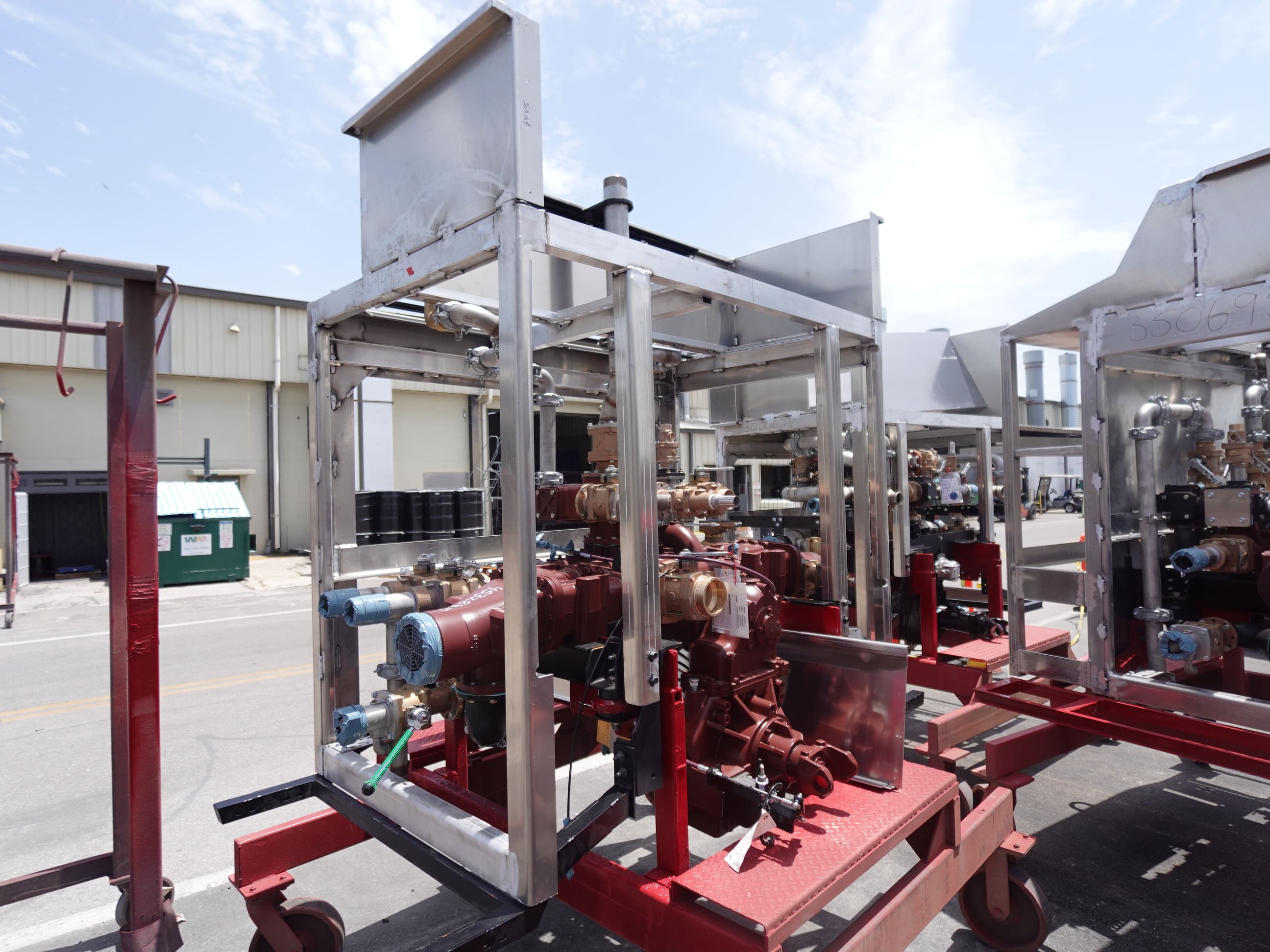

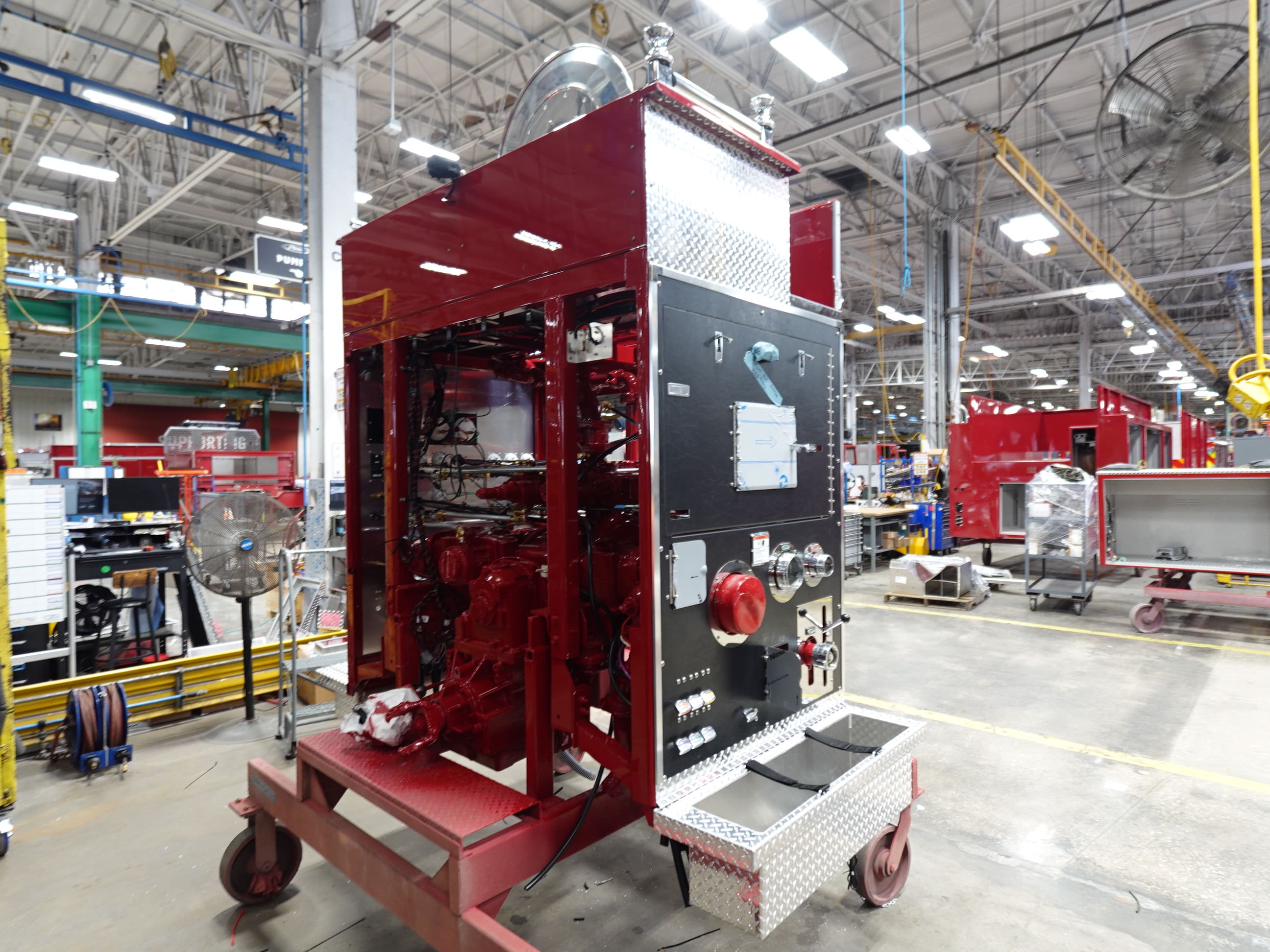

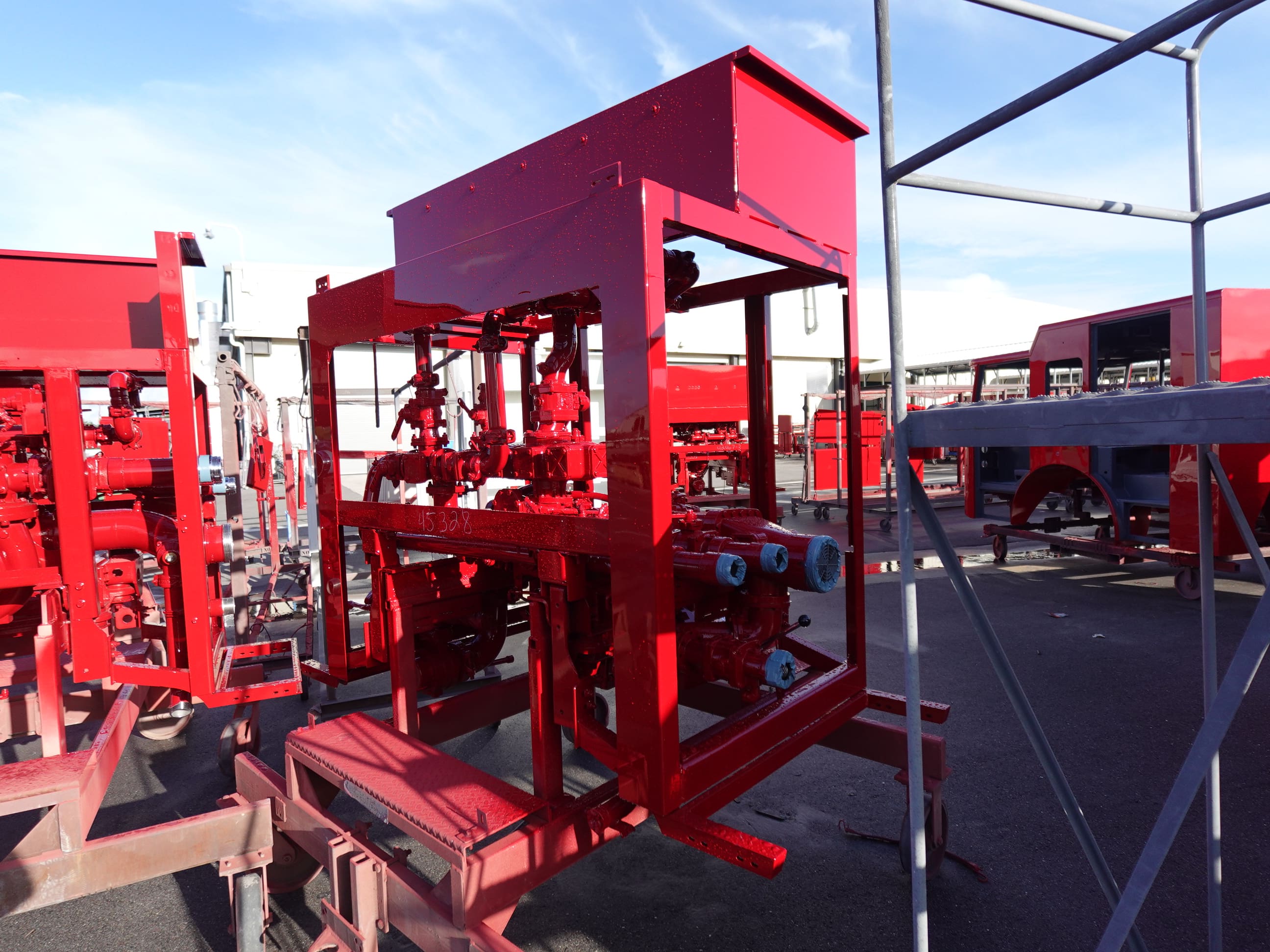

In this report, the pump house began initial assembly

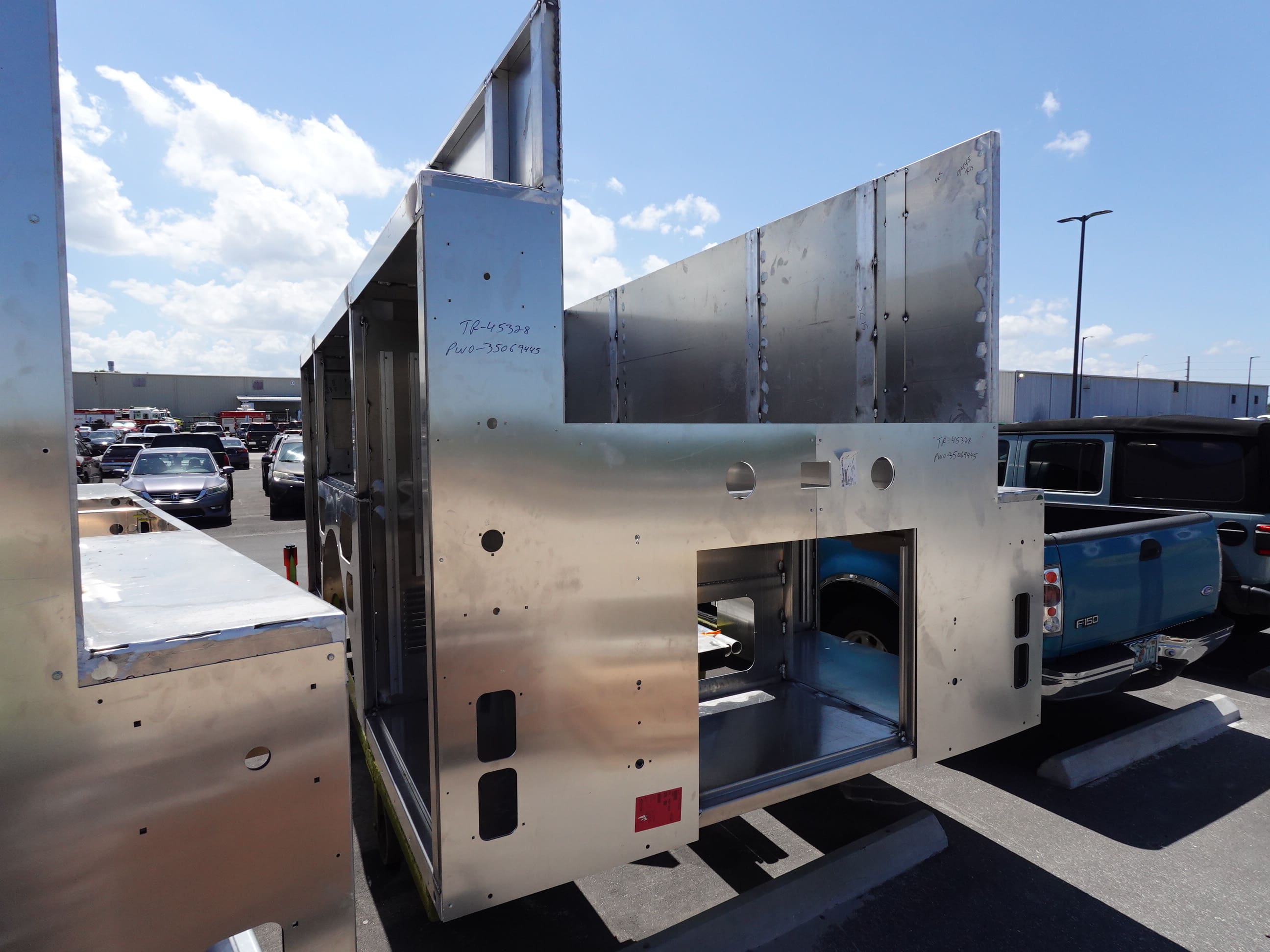

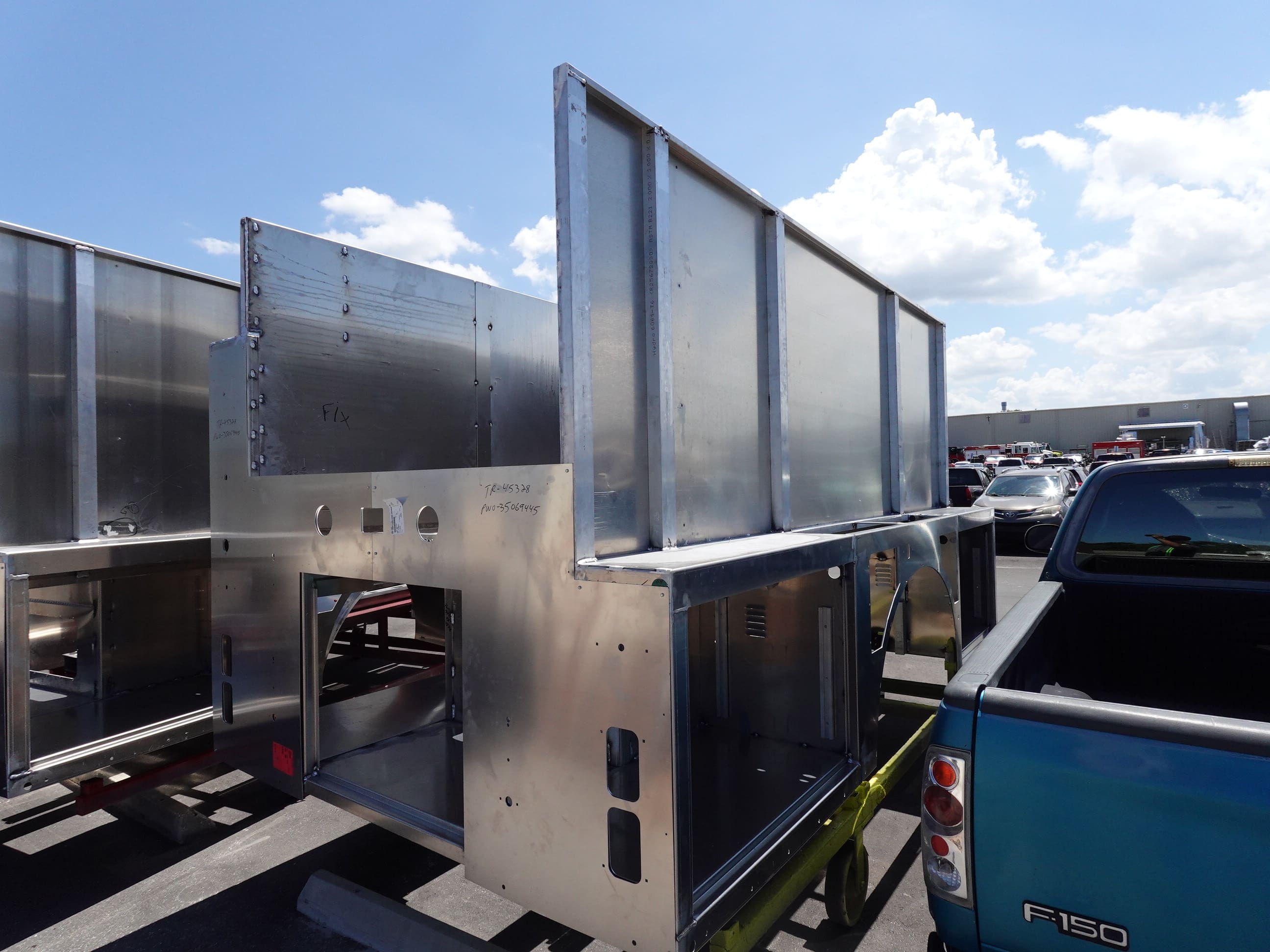

while the body completed fabrication.

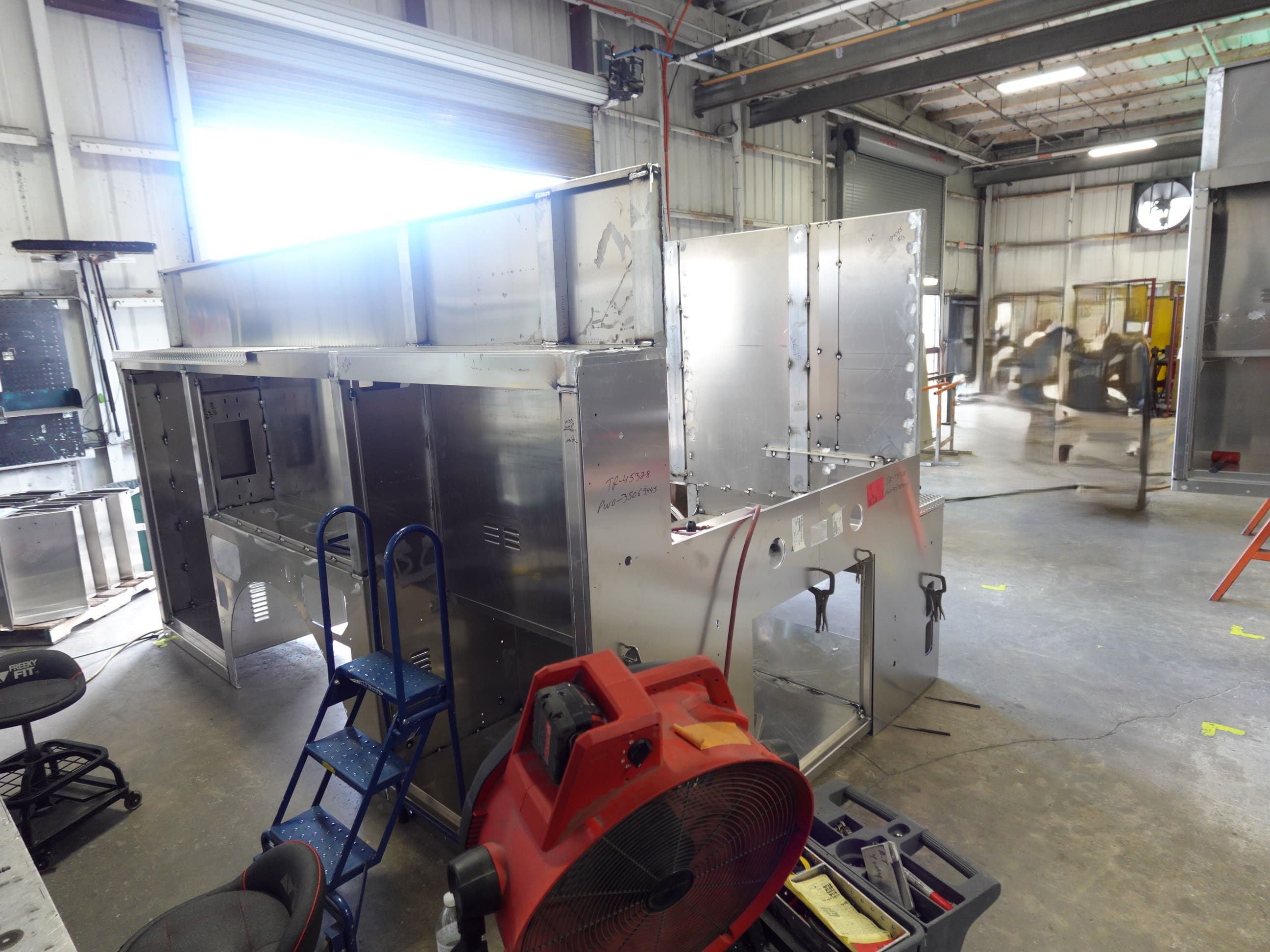

06-19-26

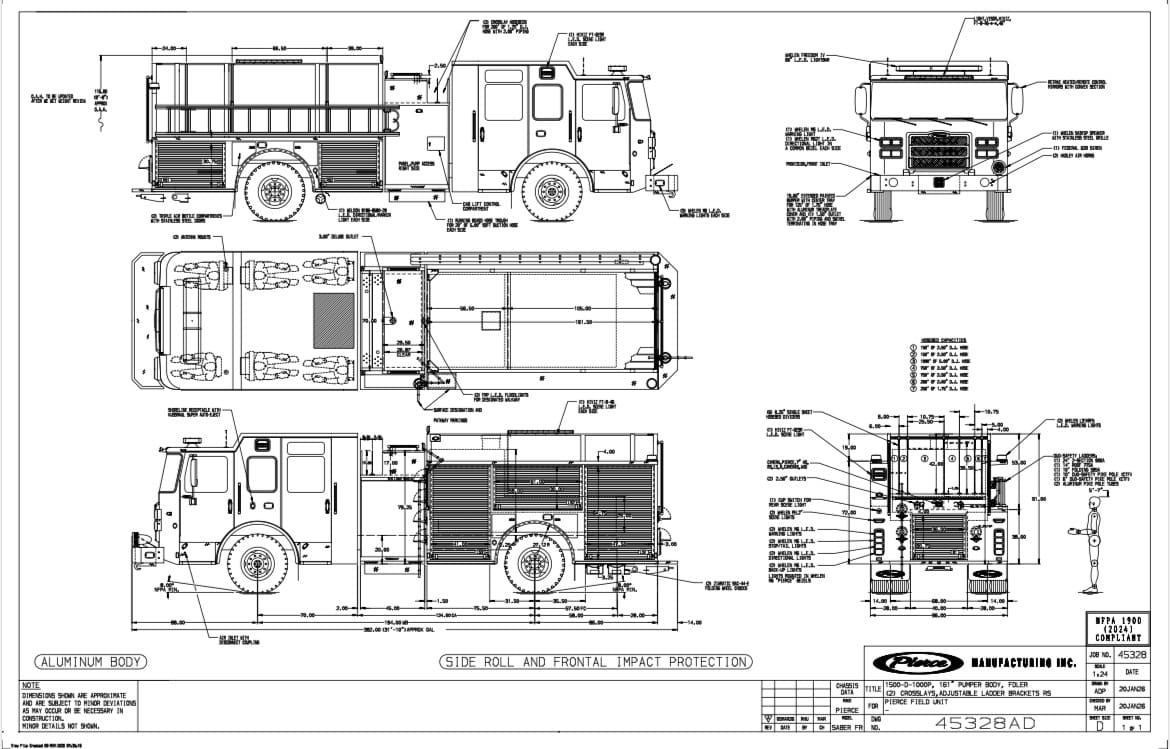

This new Pierce apparatus is now
in production. In this report, the body began fabrication.
