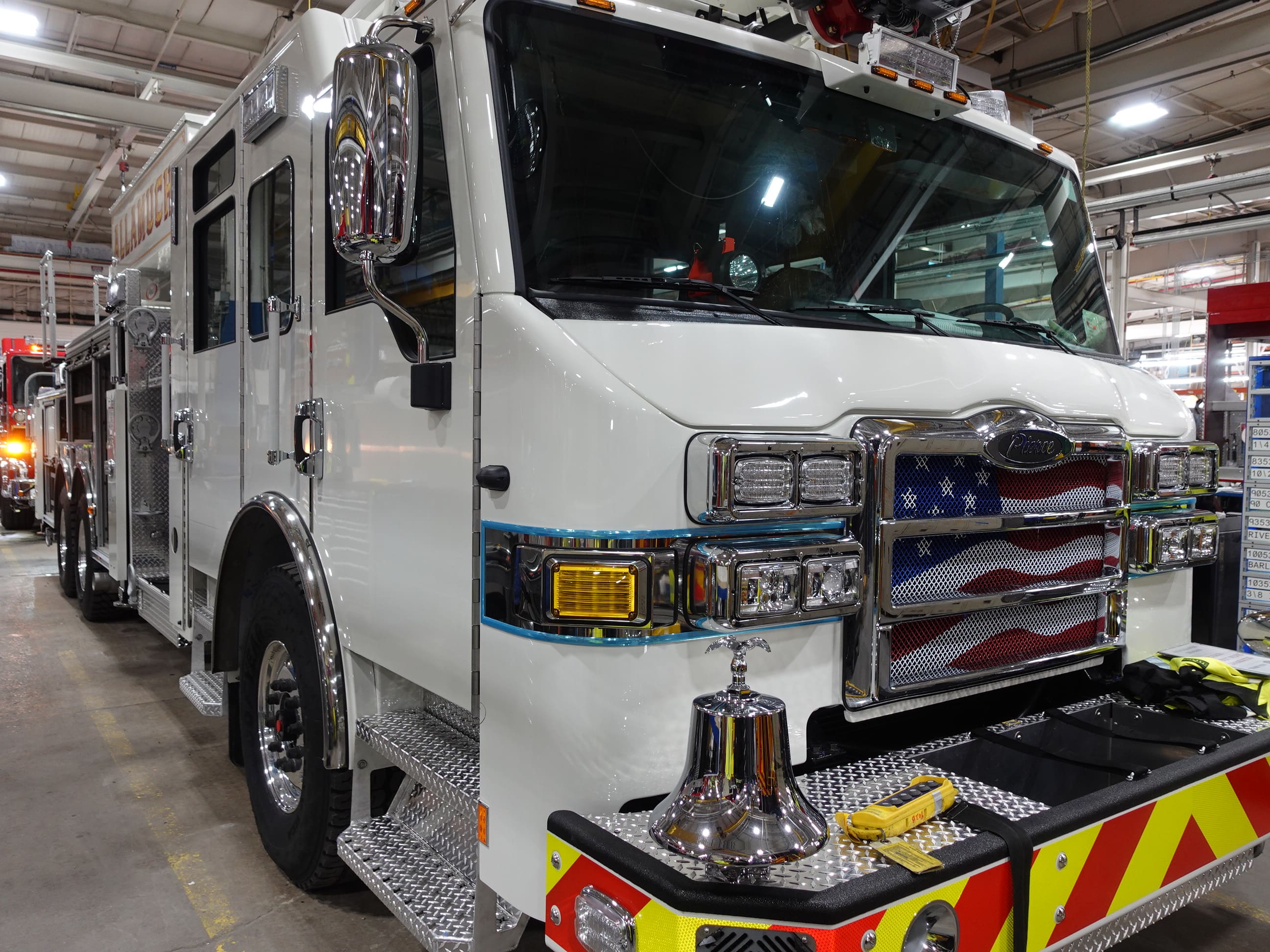

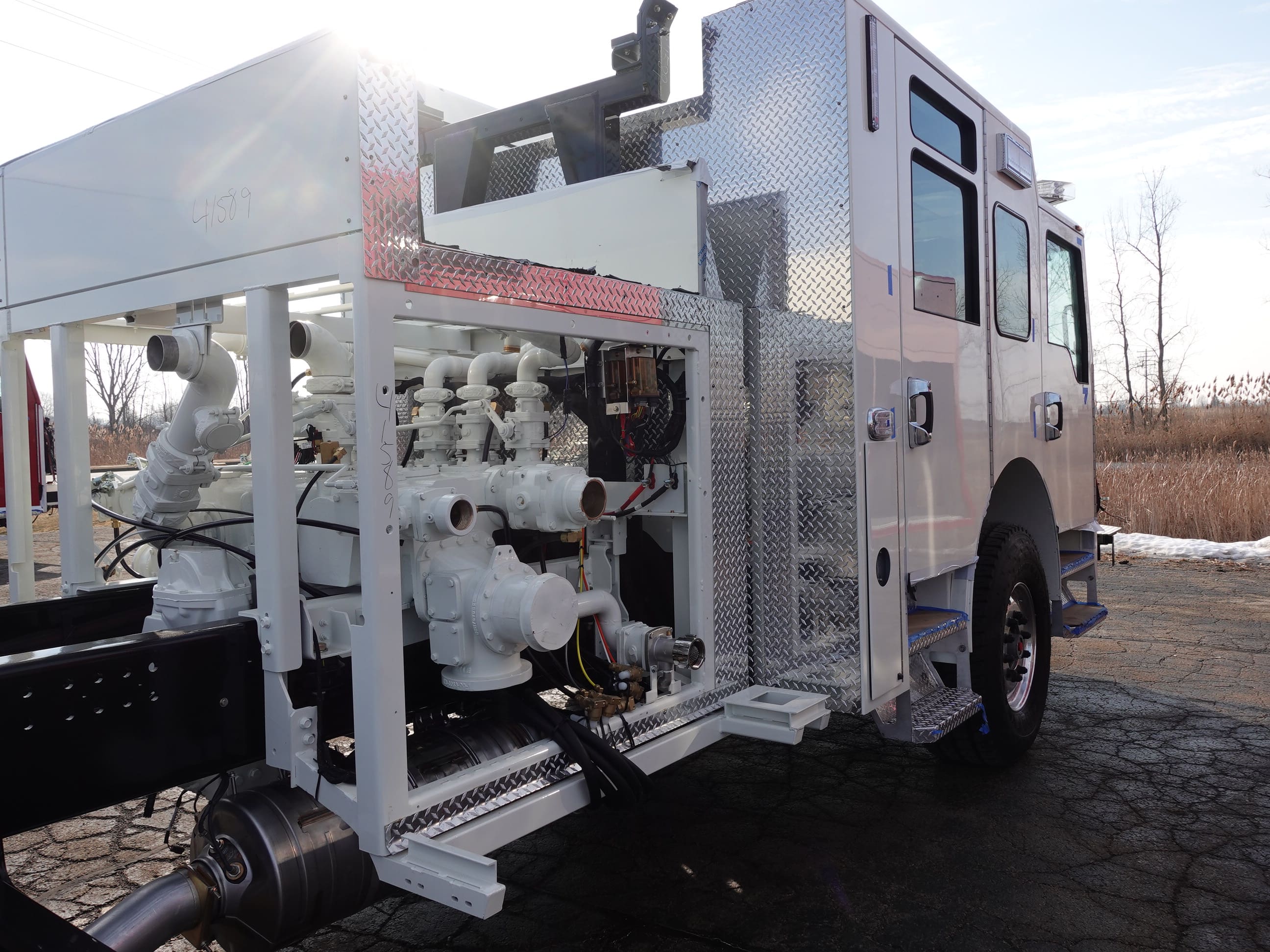

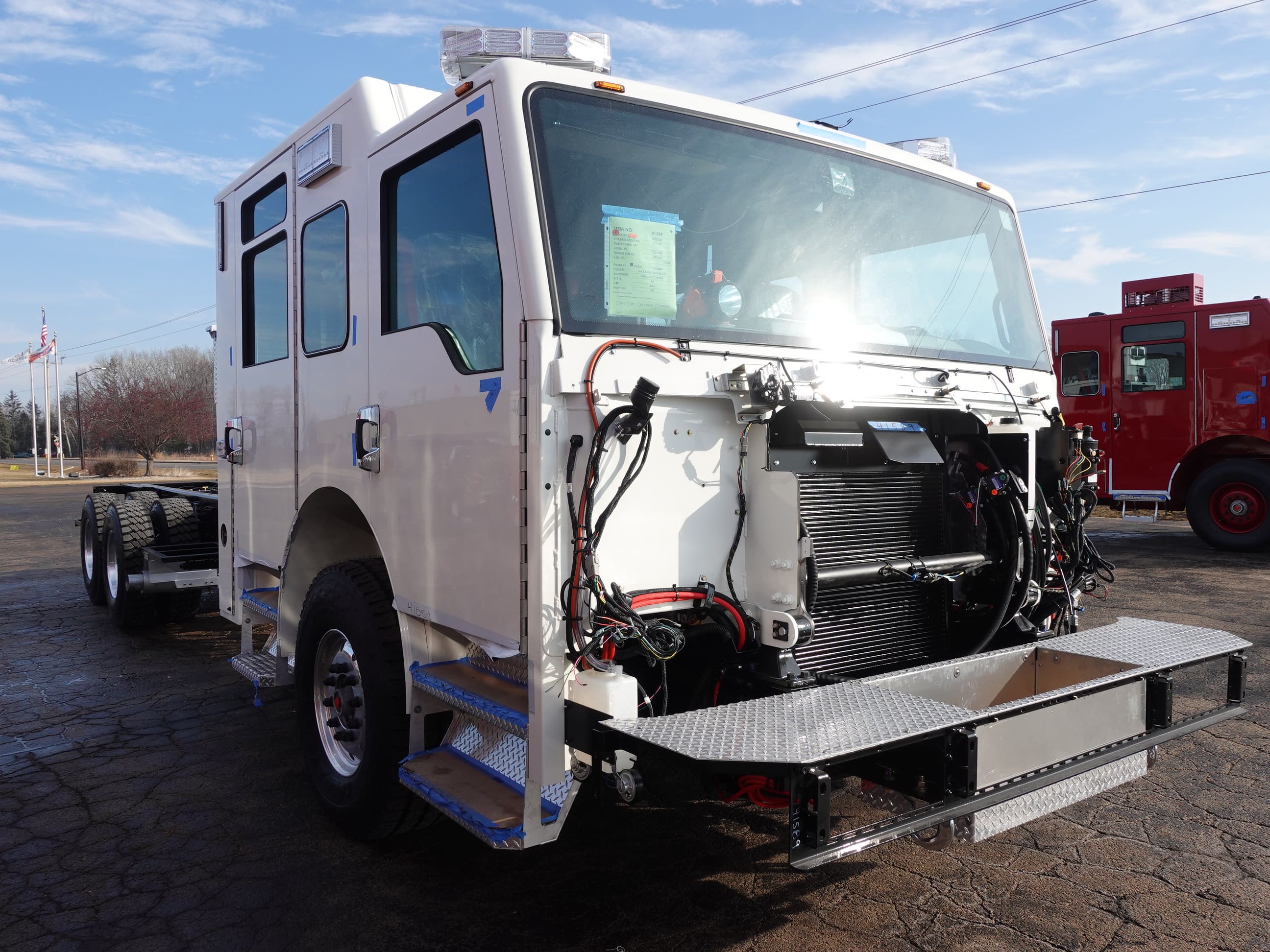

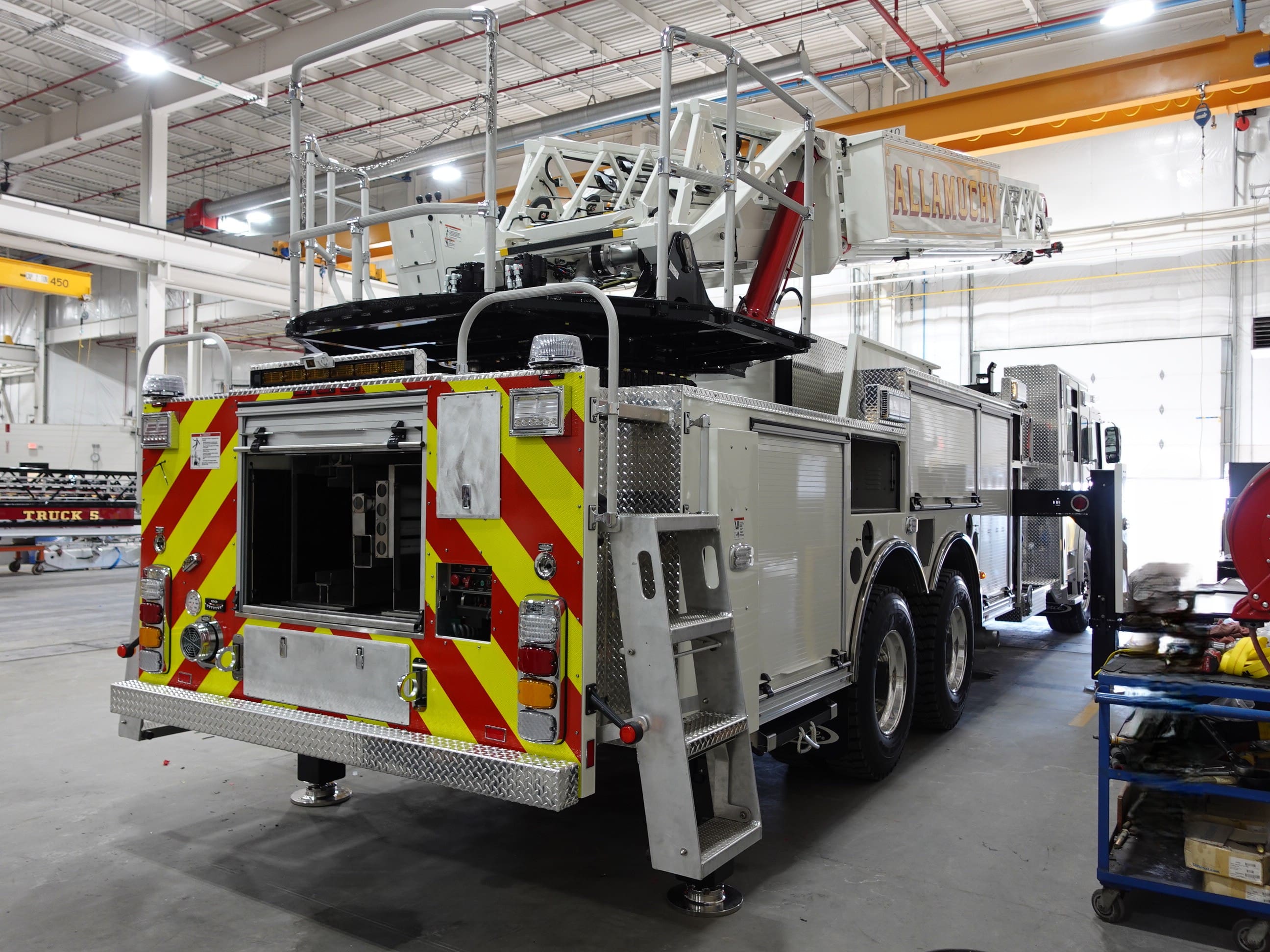

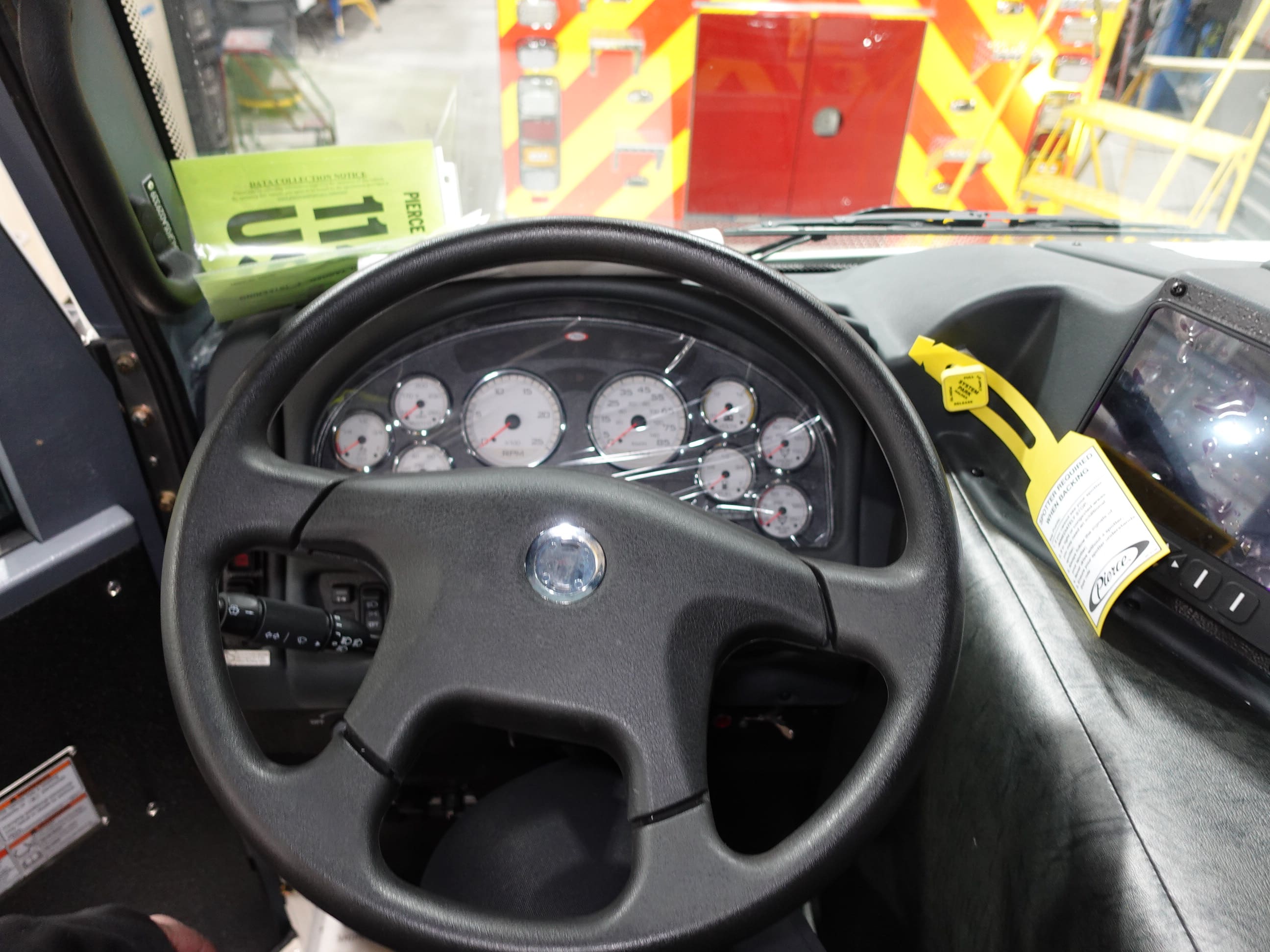

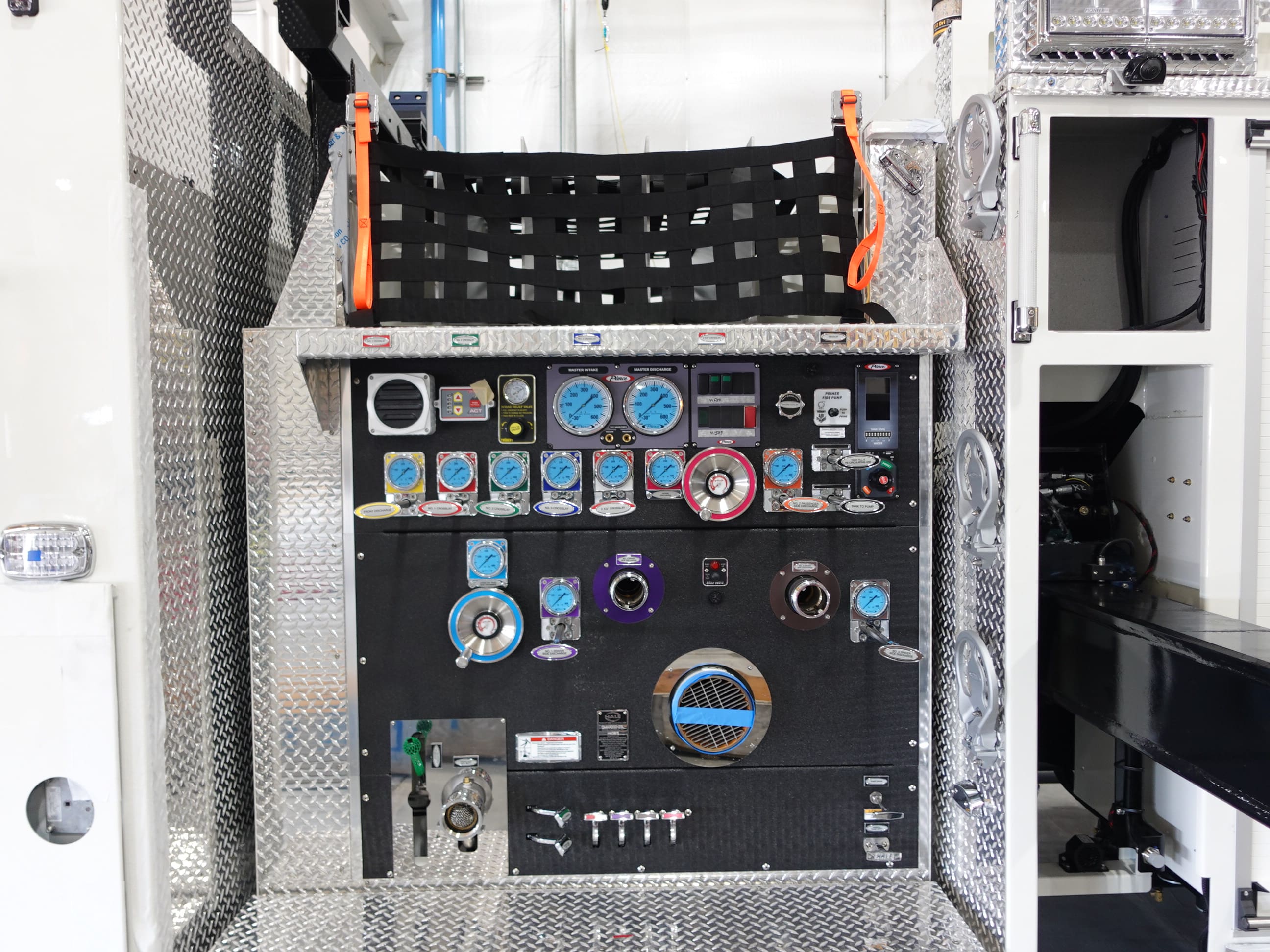

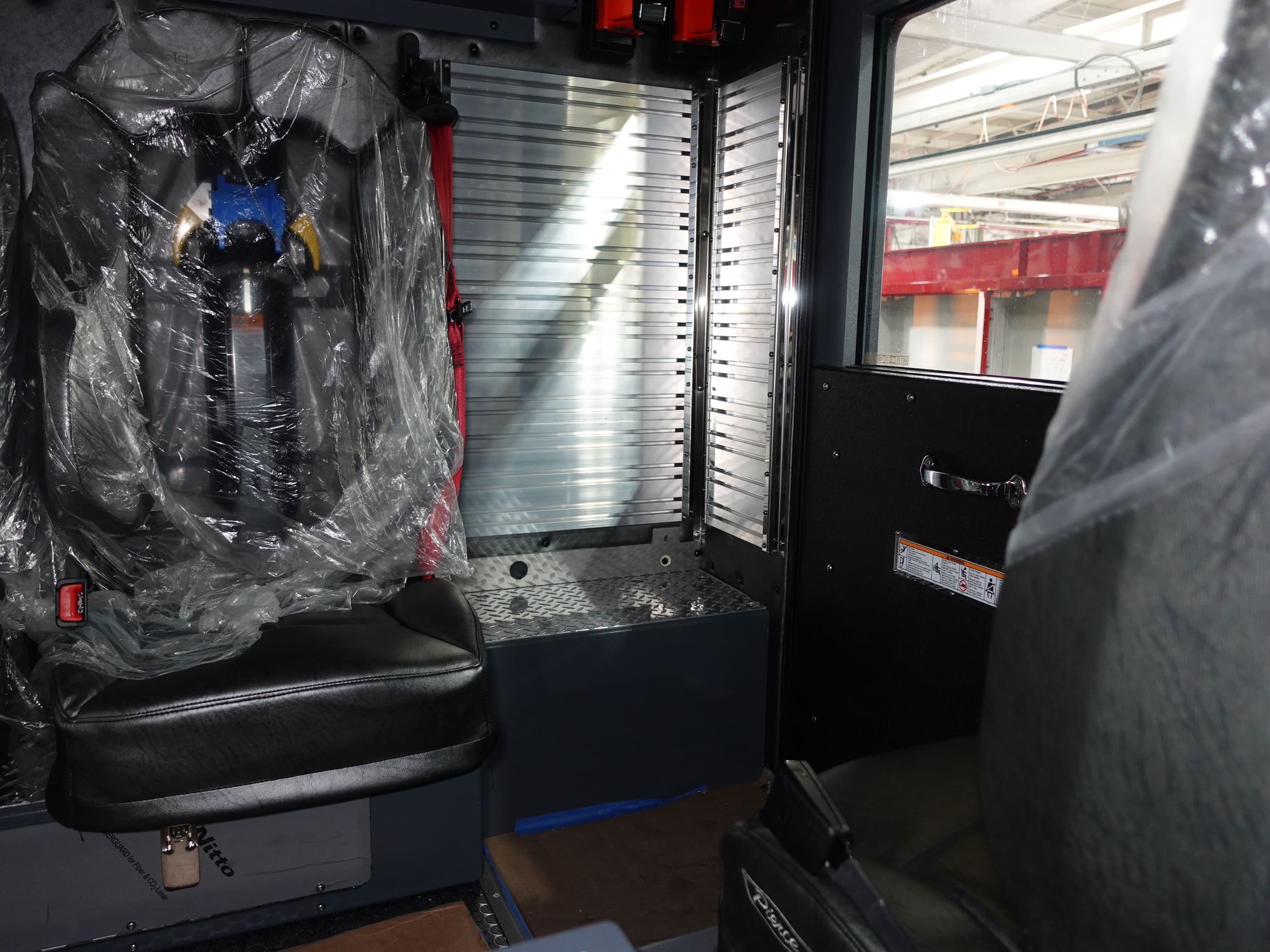

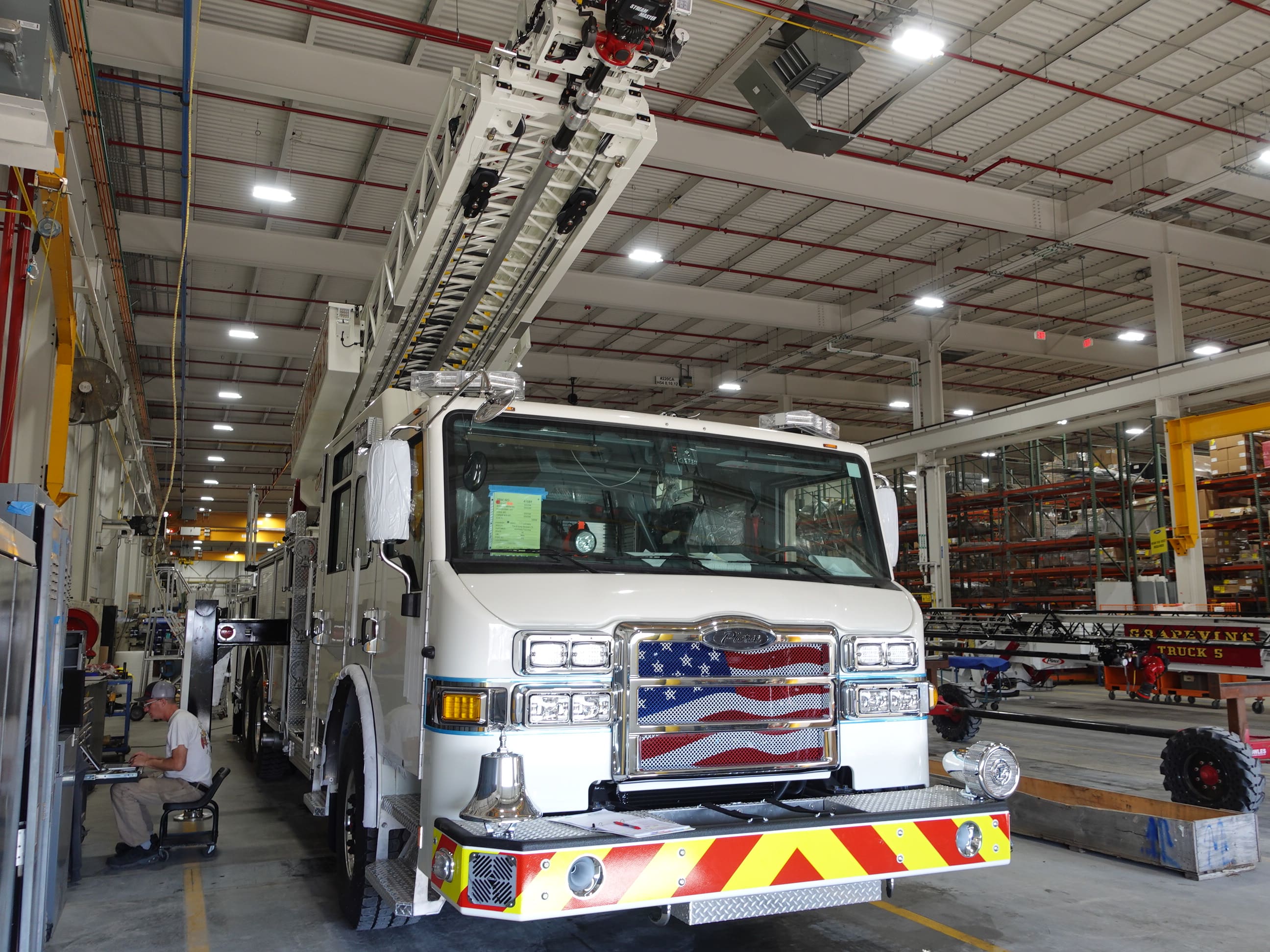

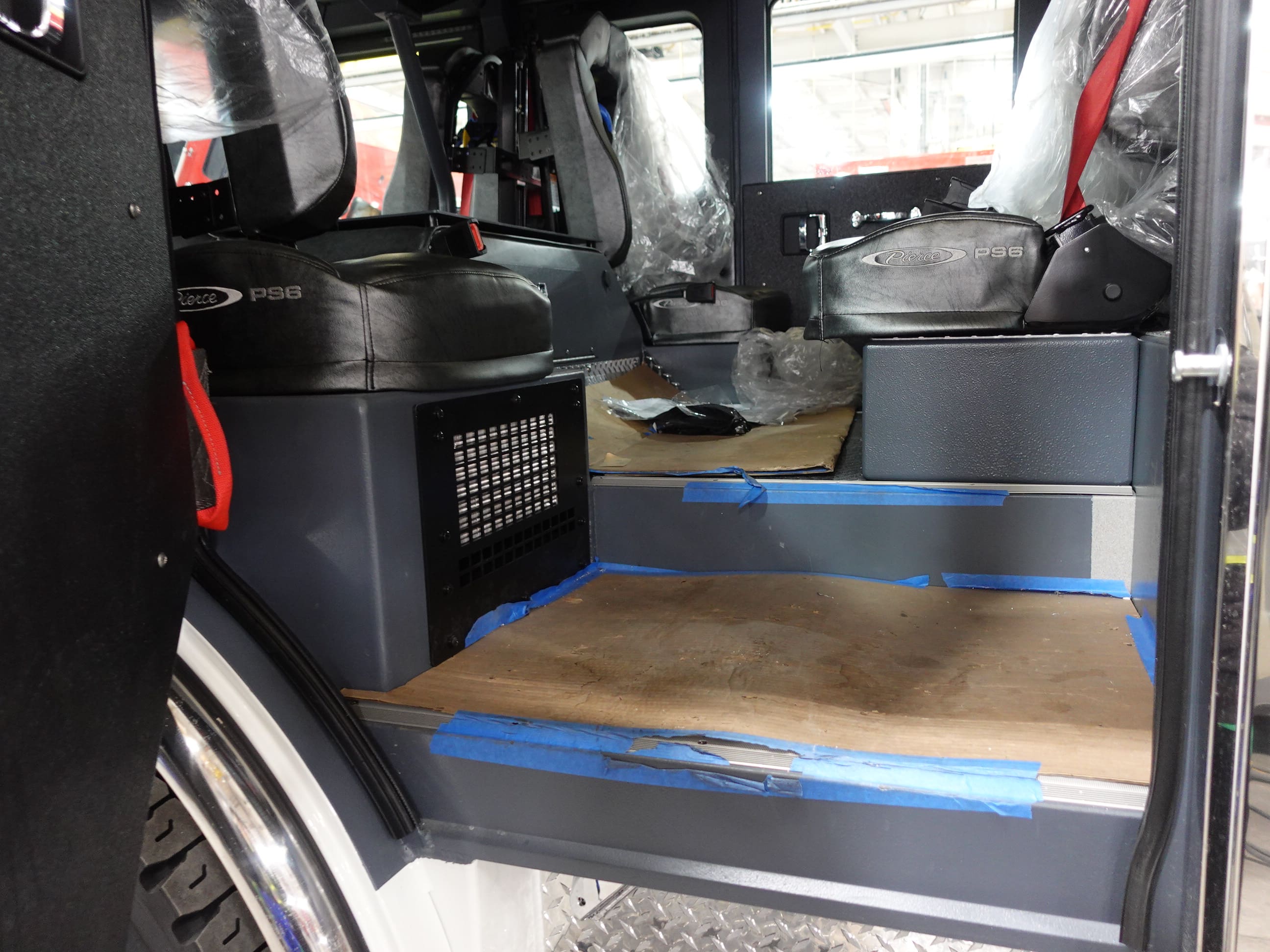

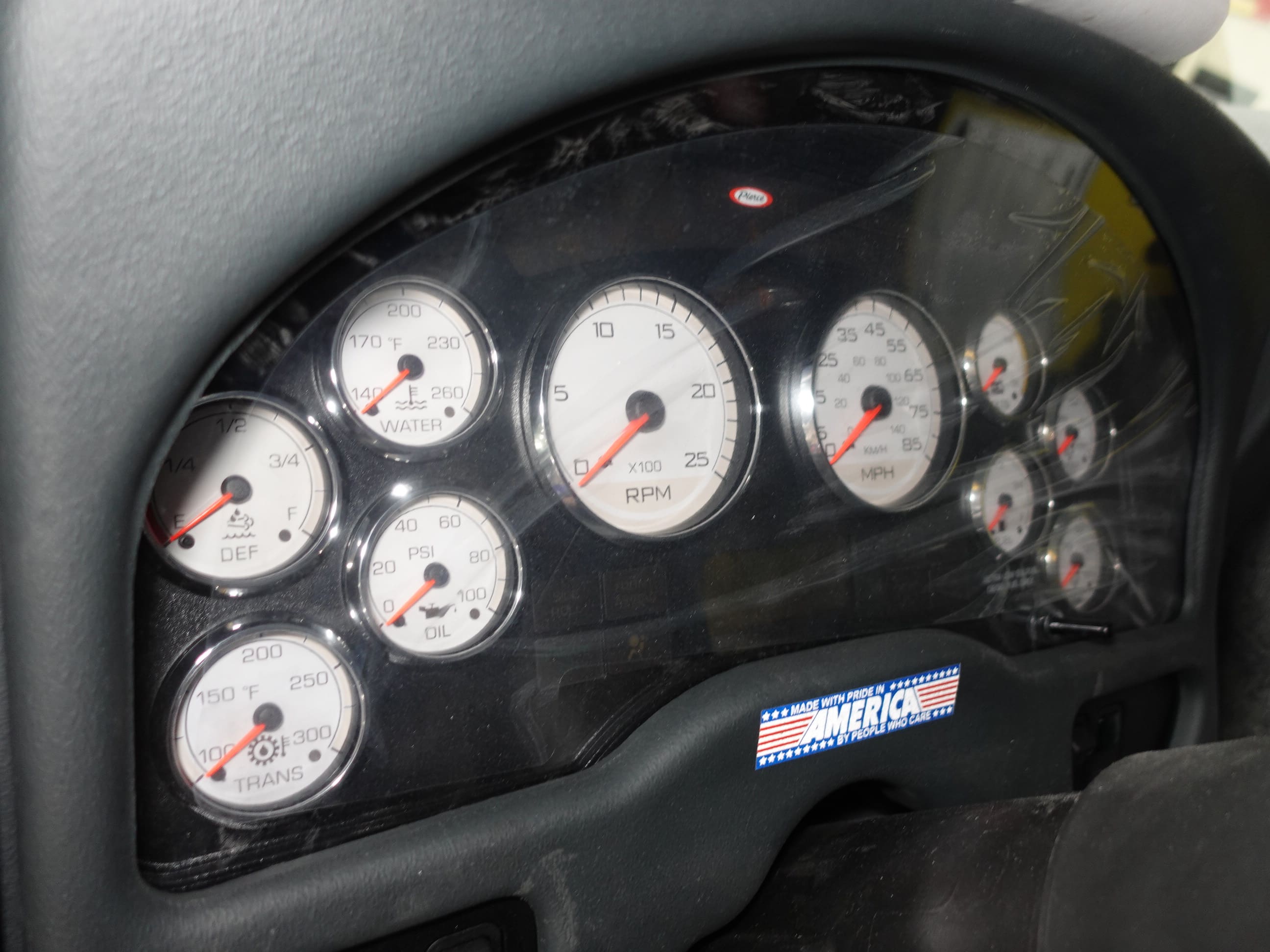

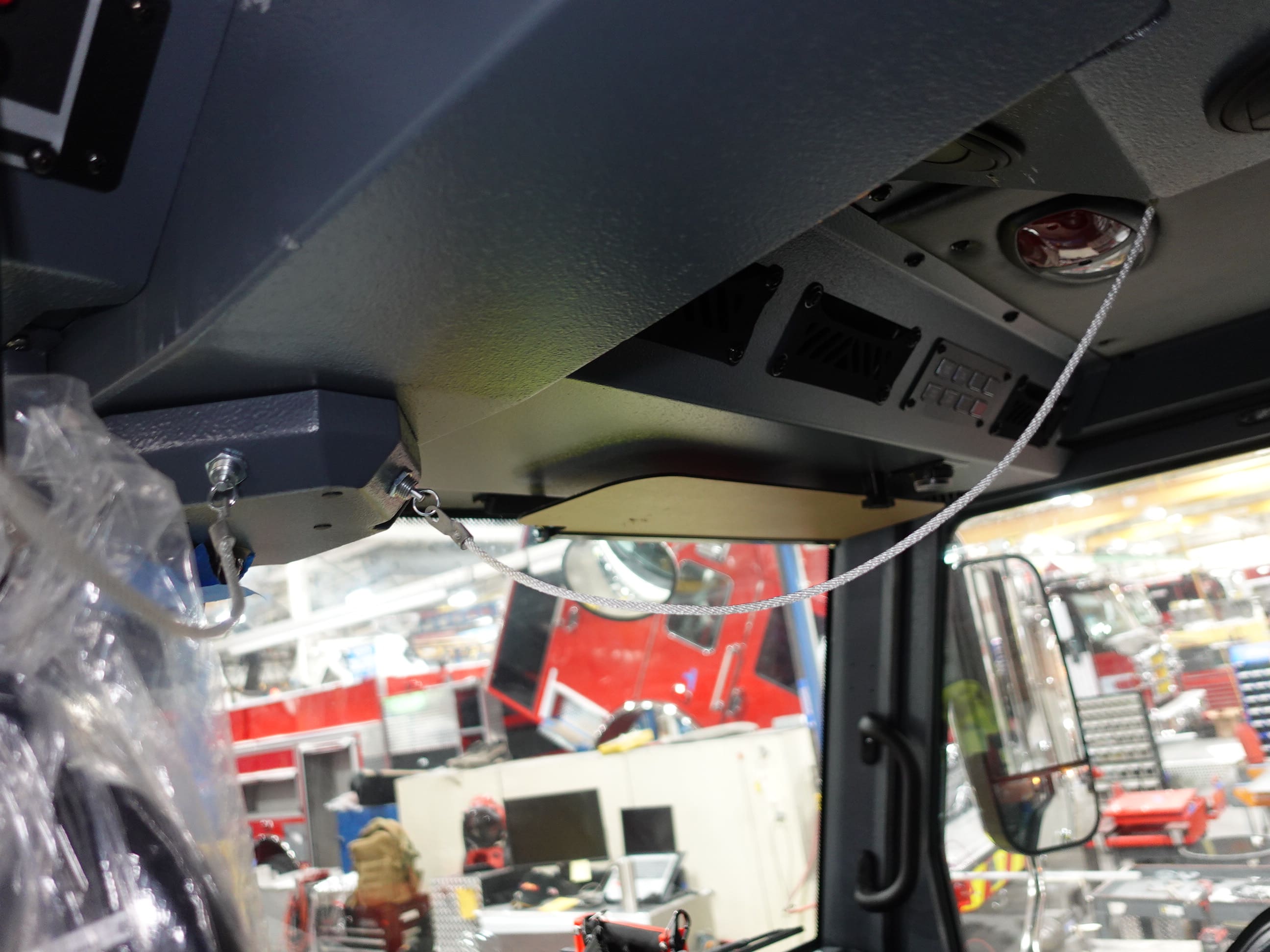

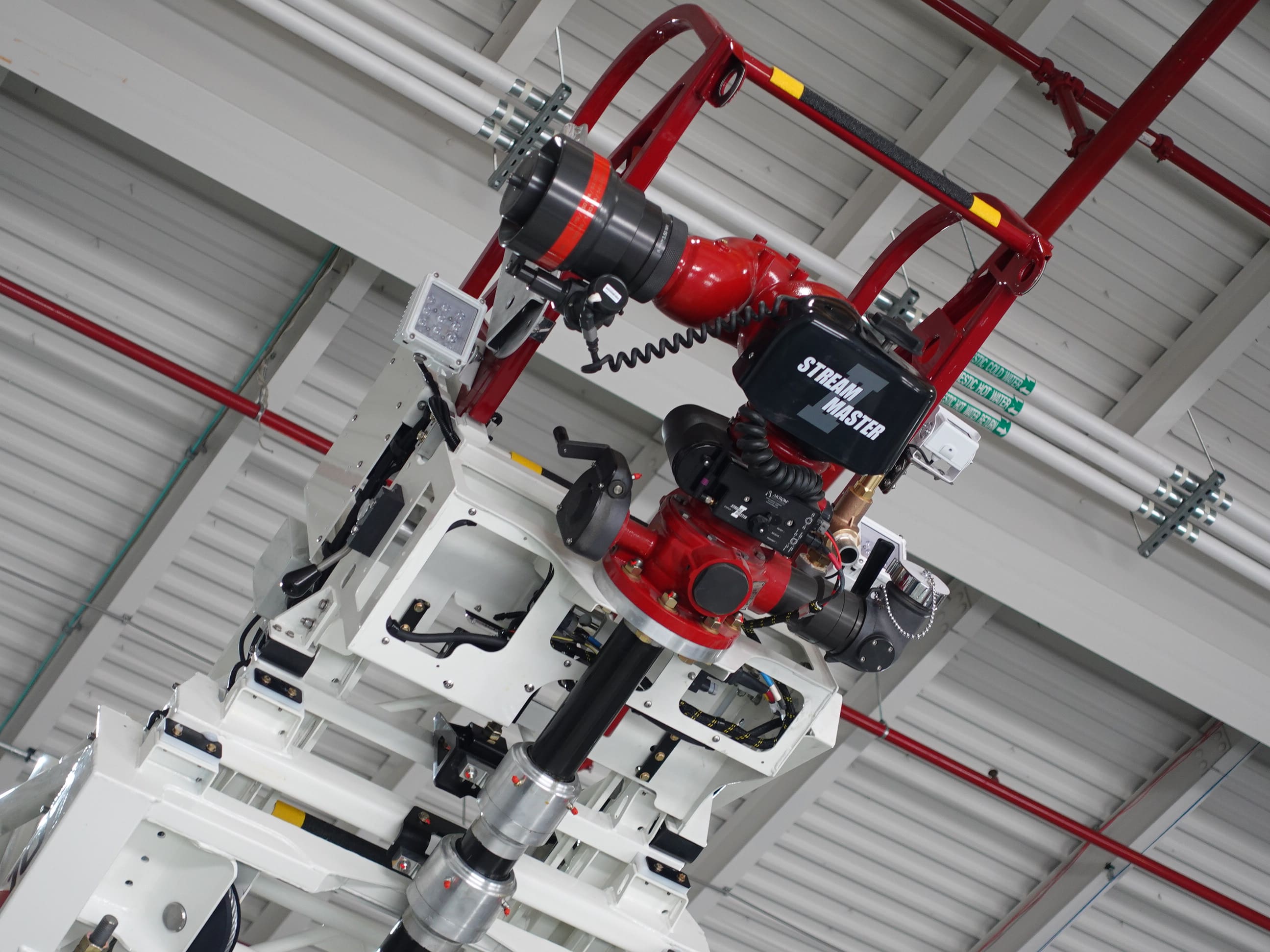

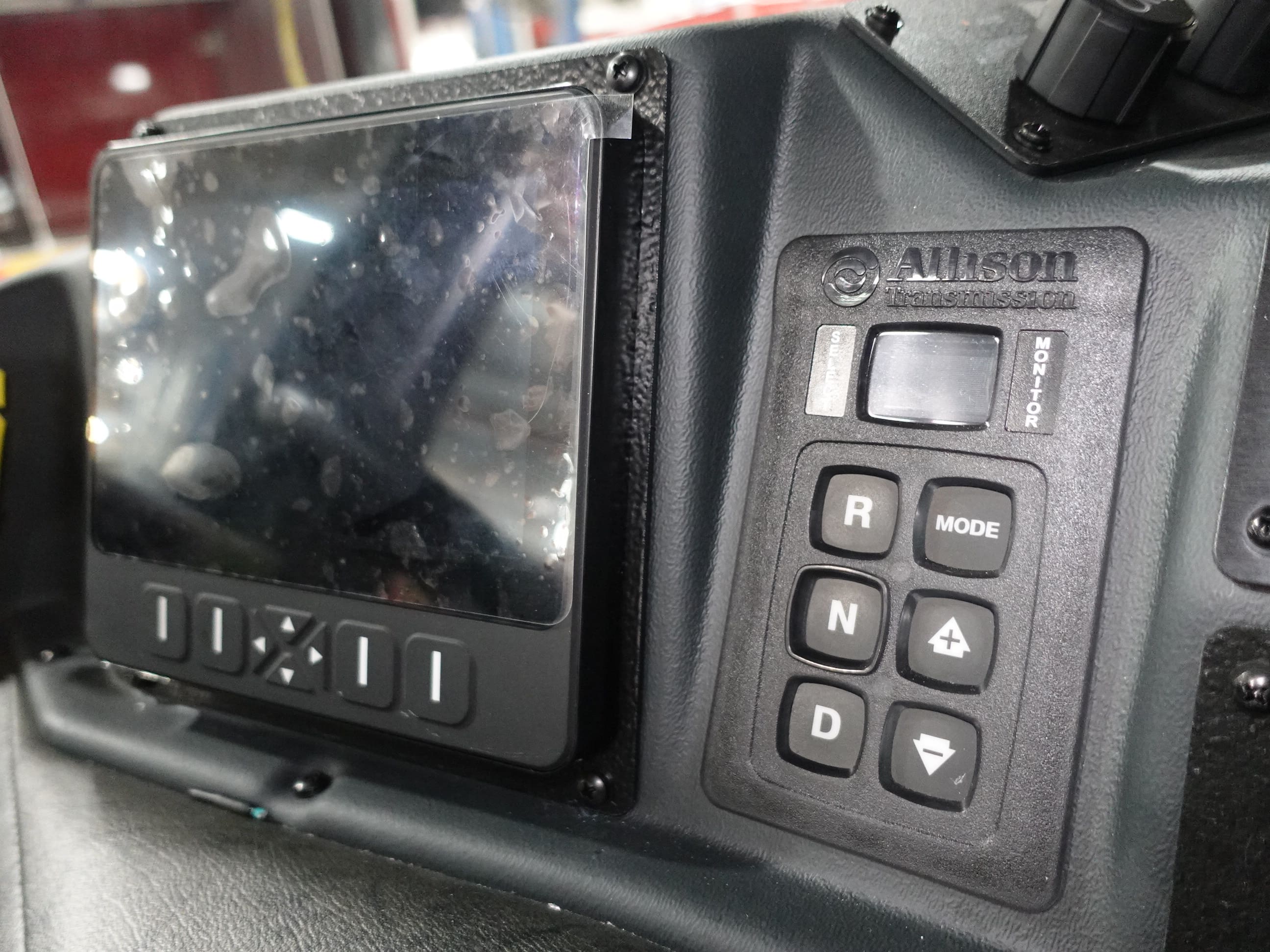

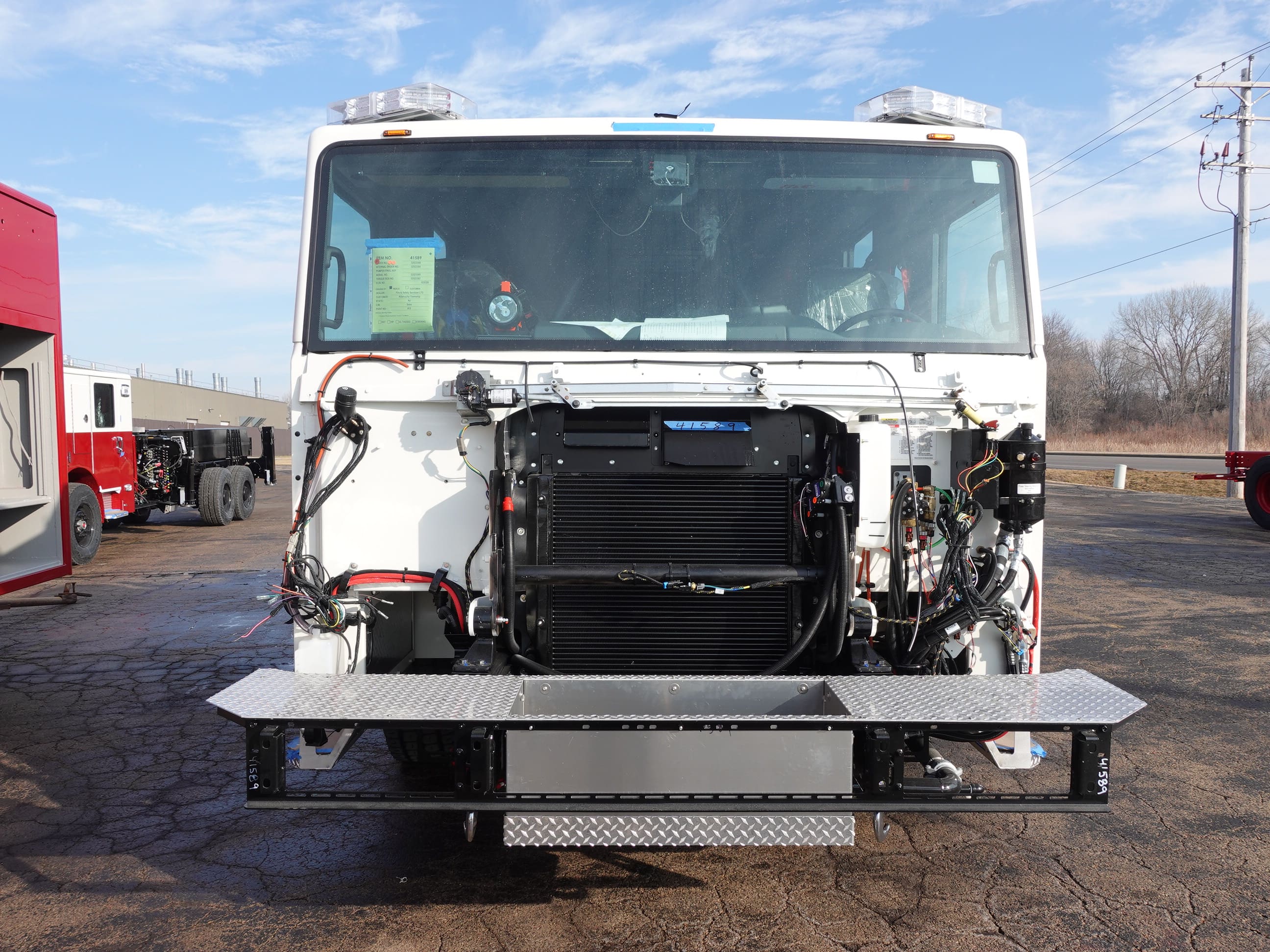

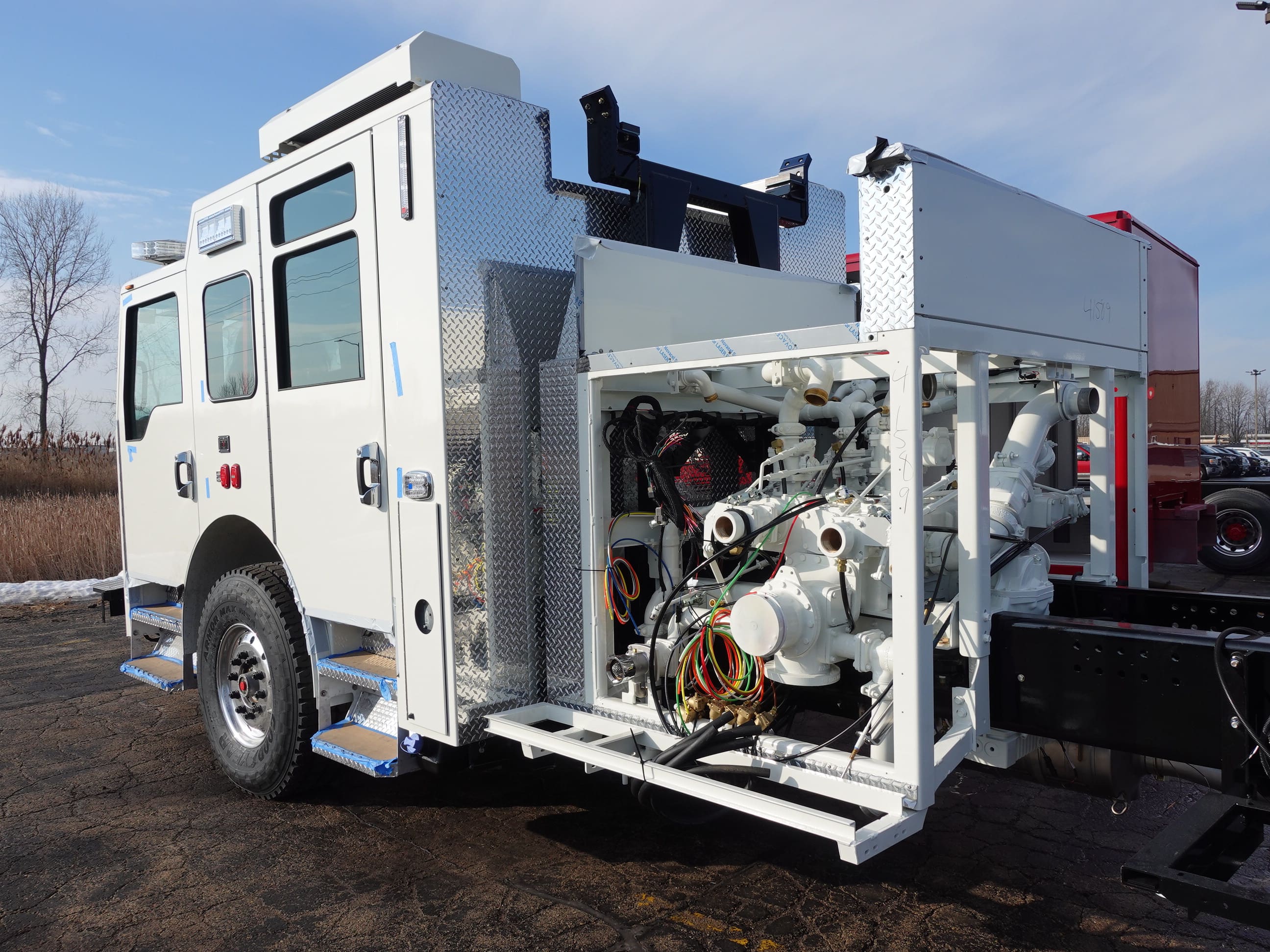

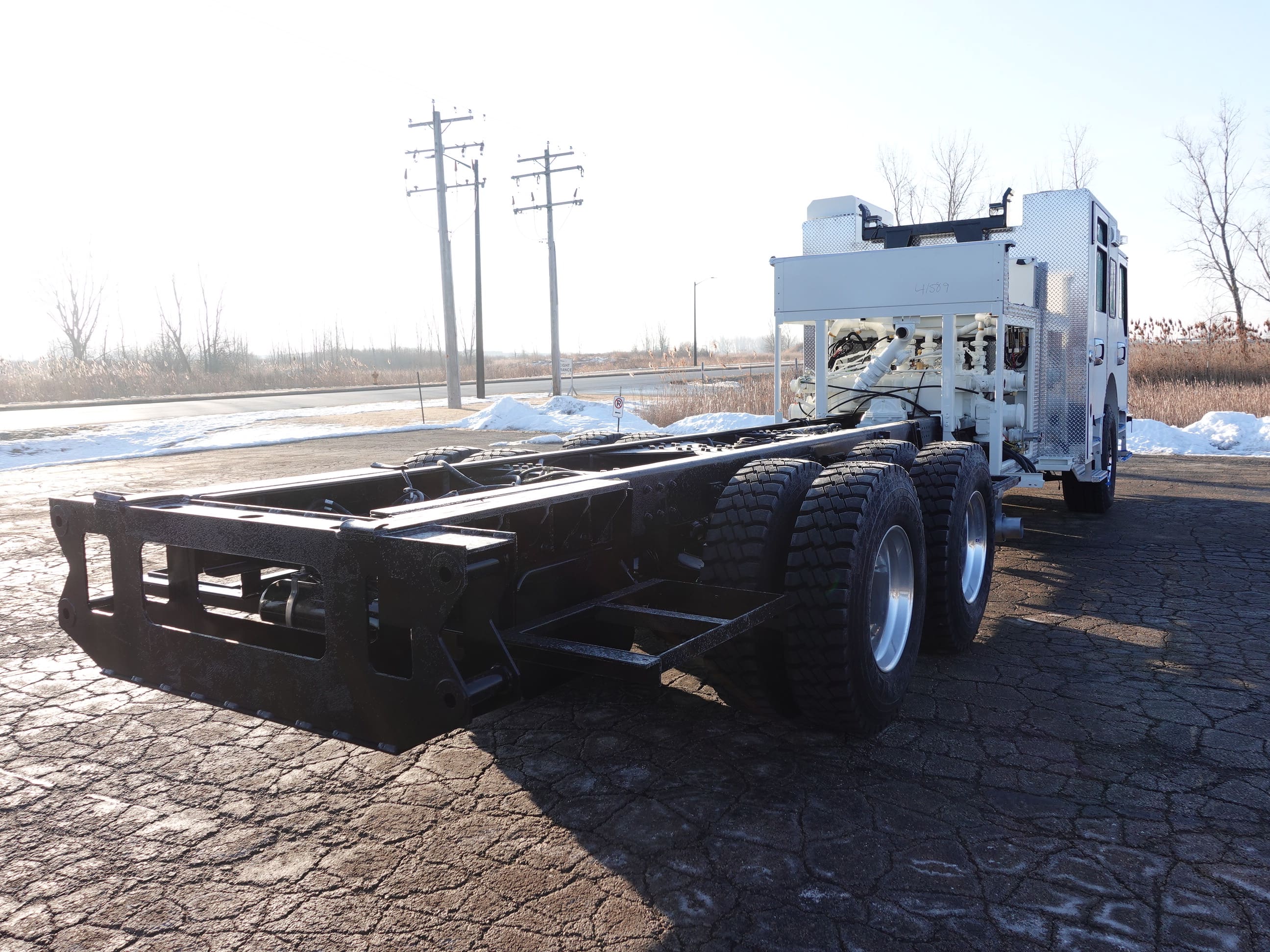

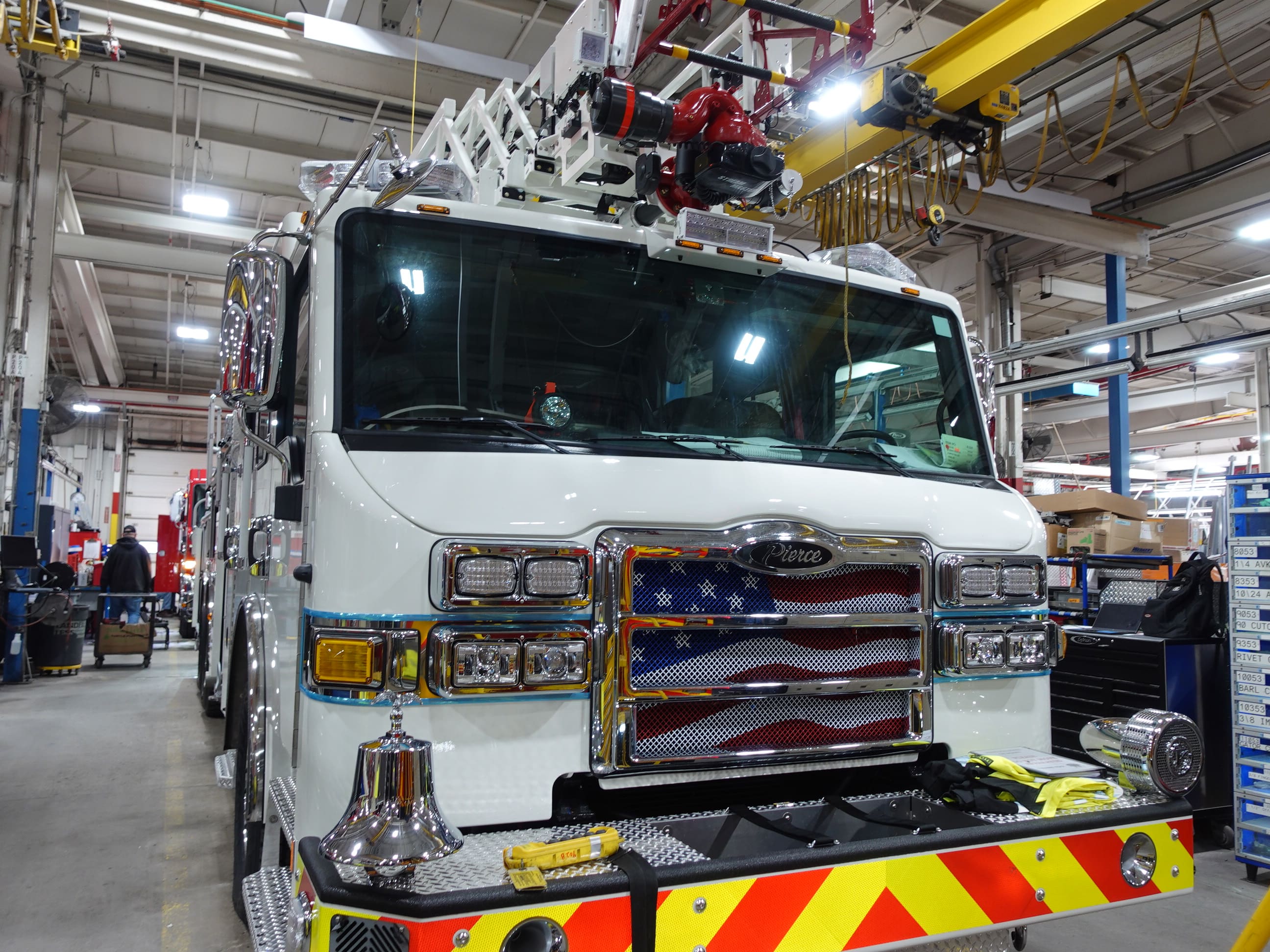

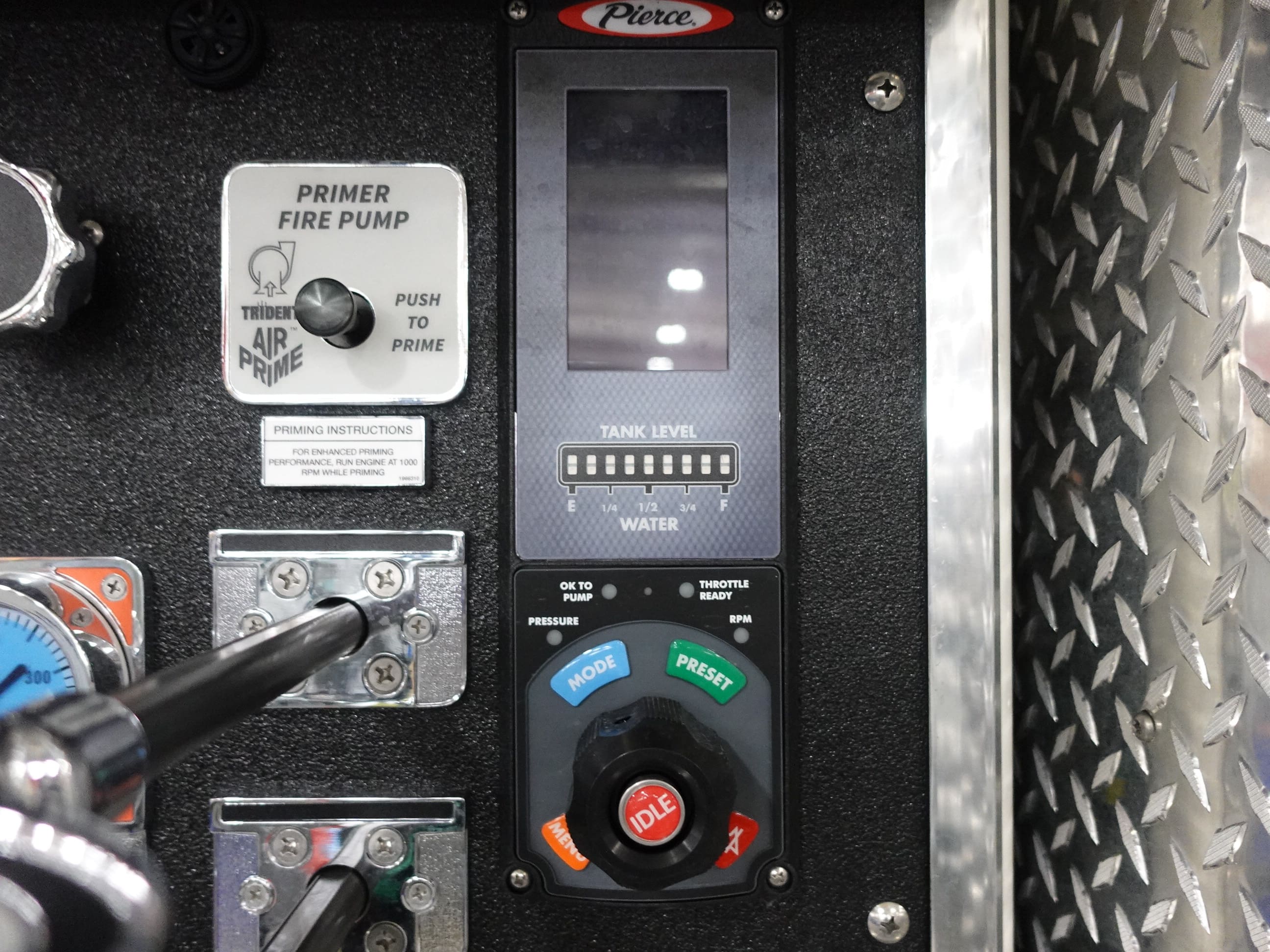

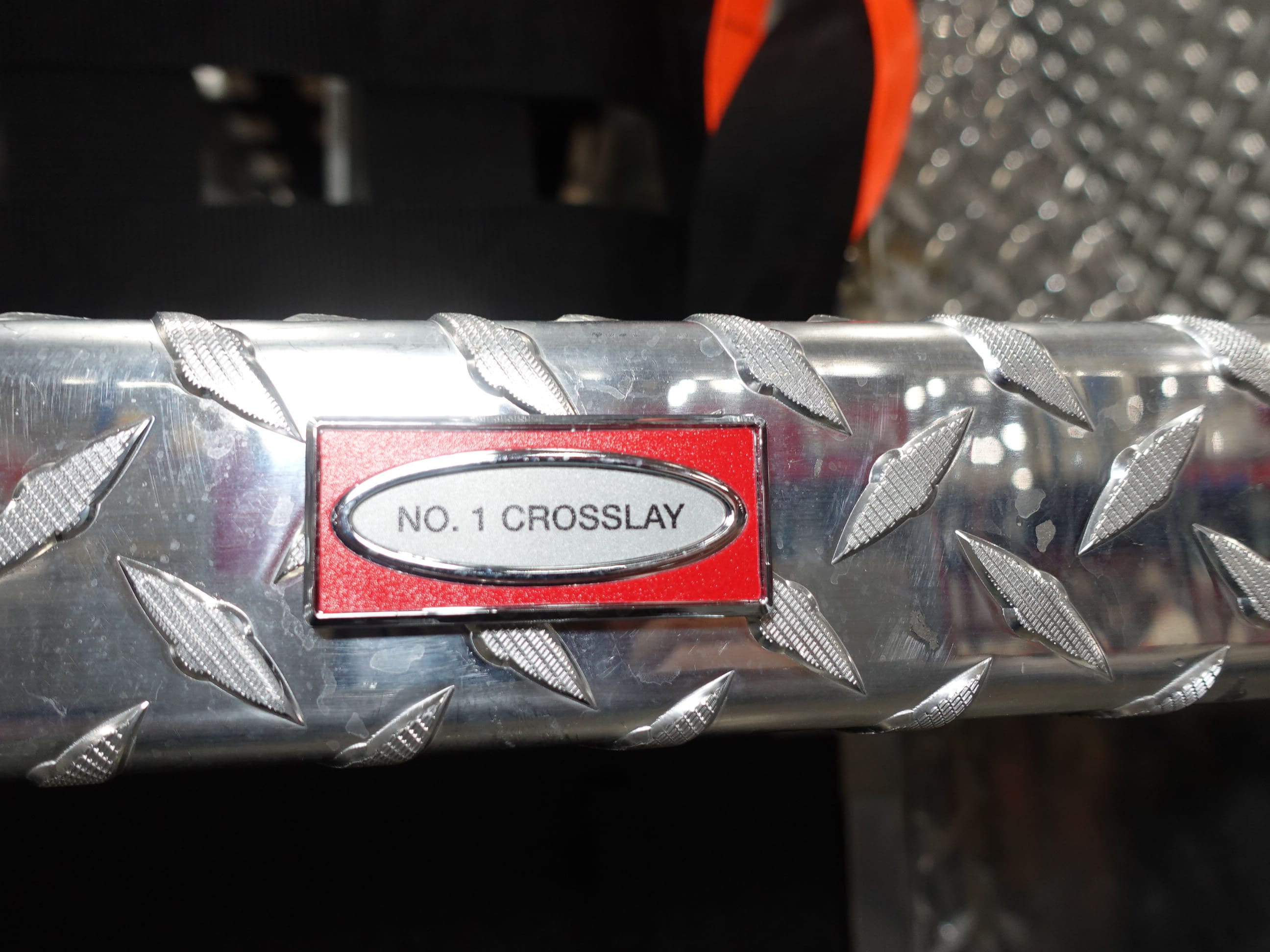

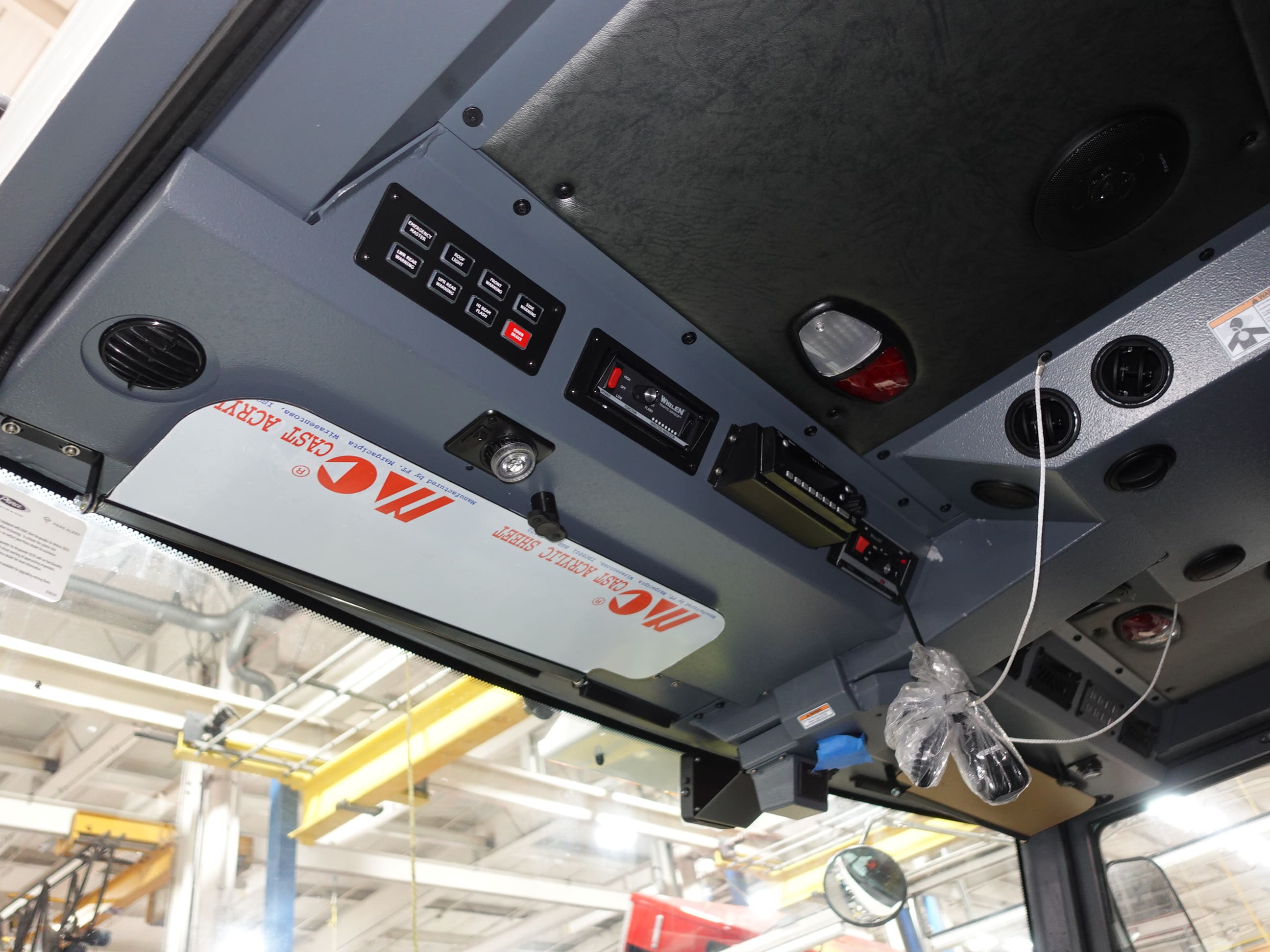

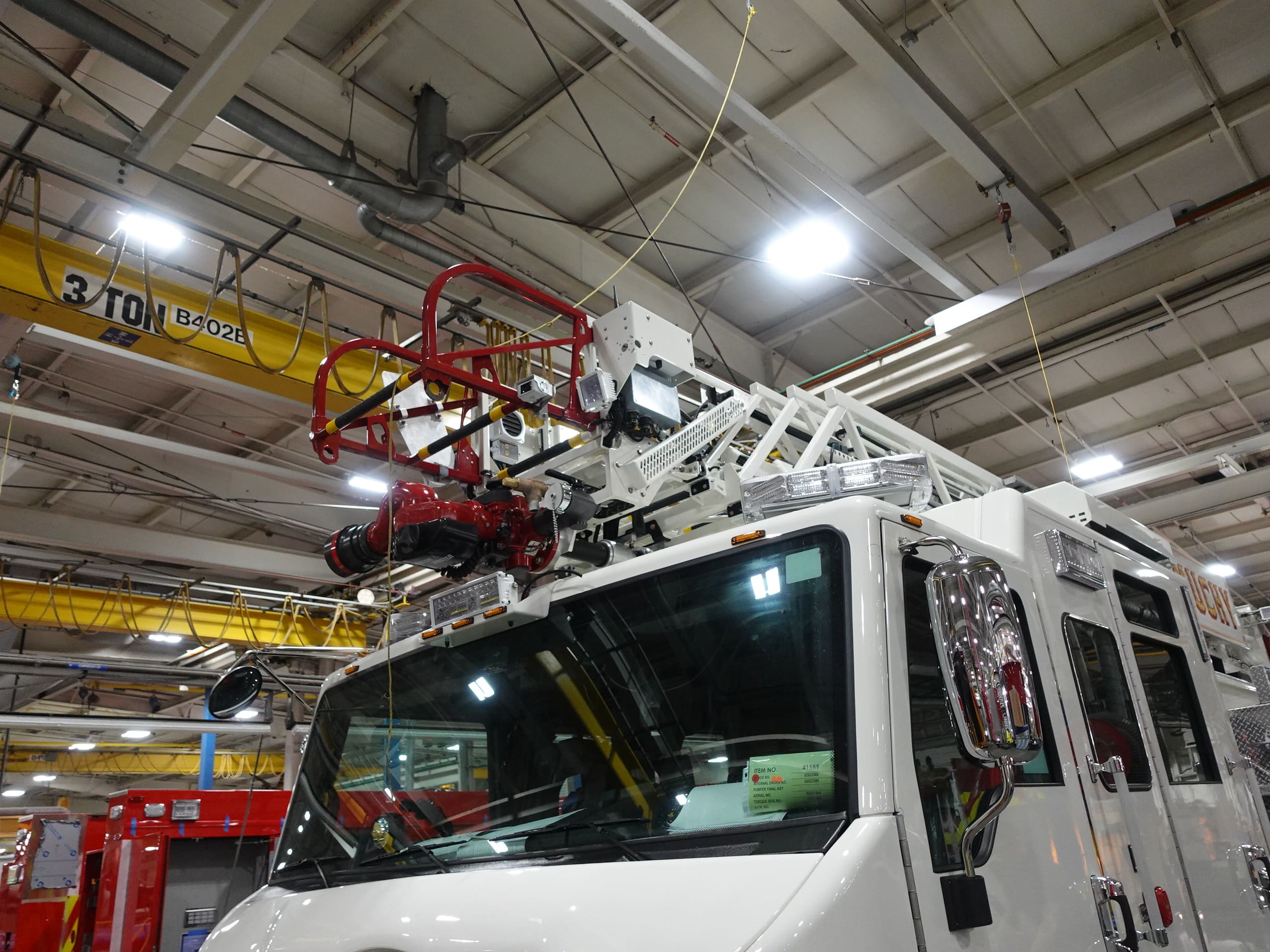

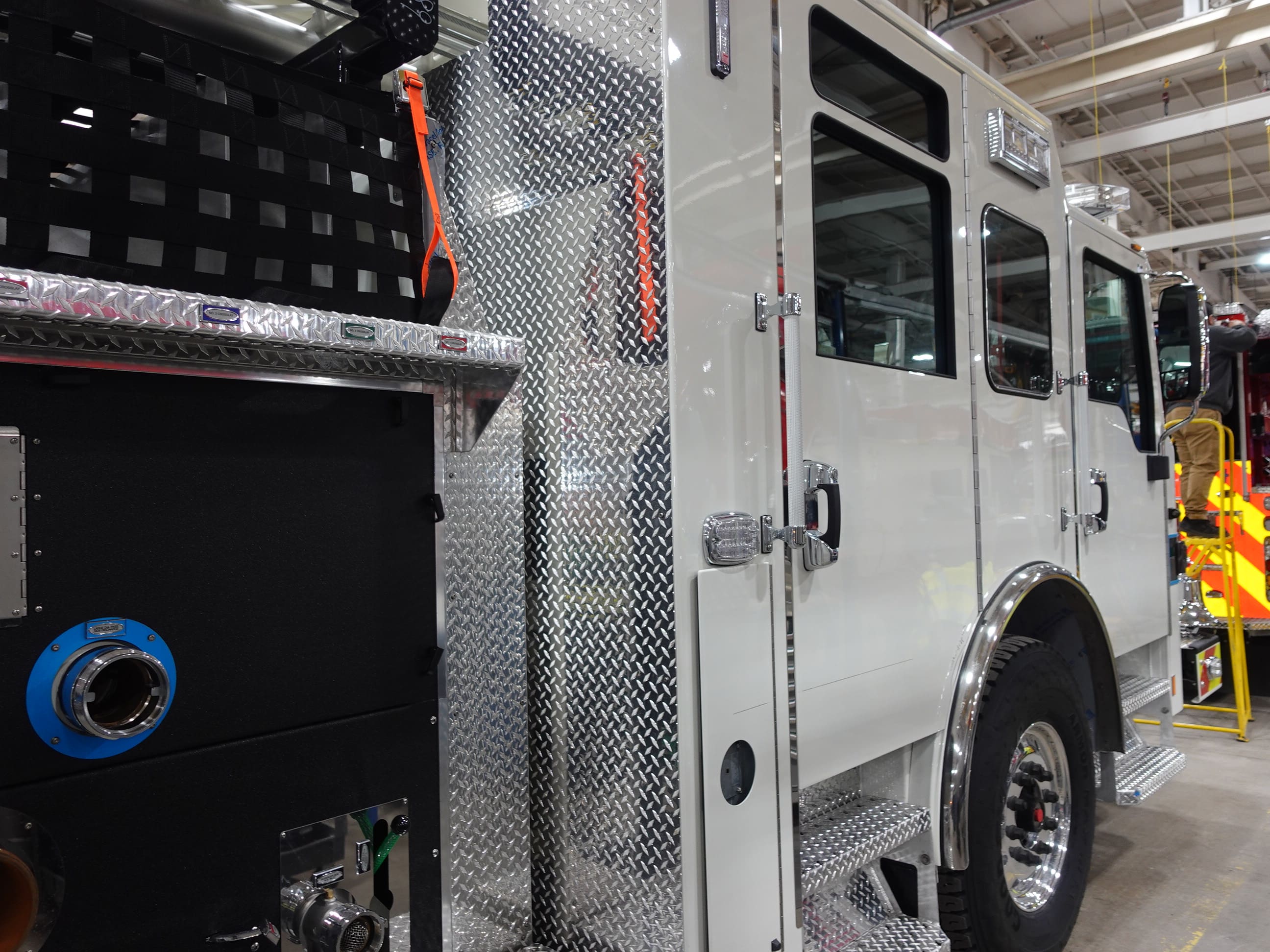

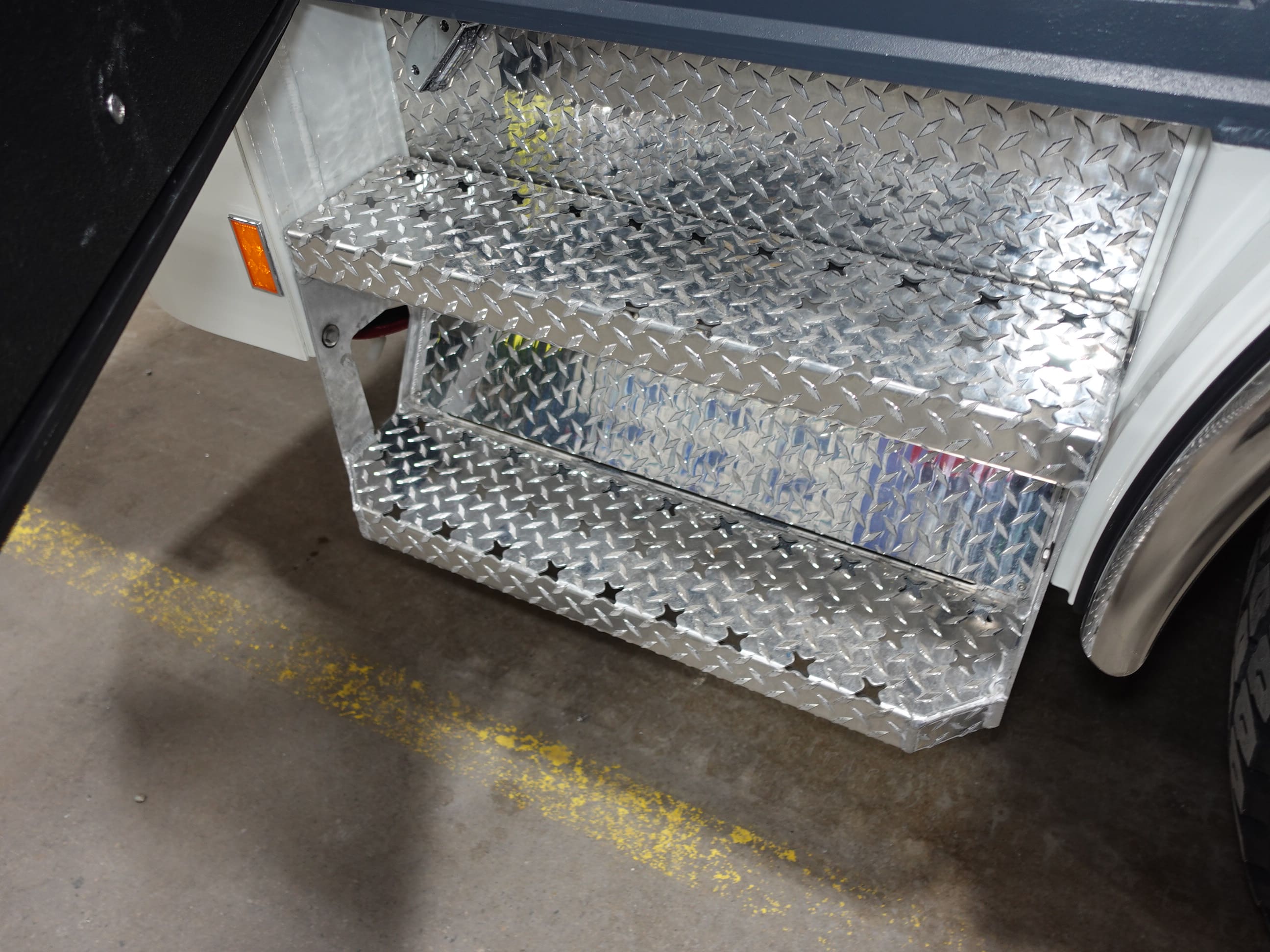

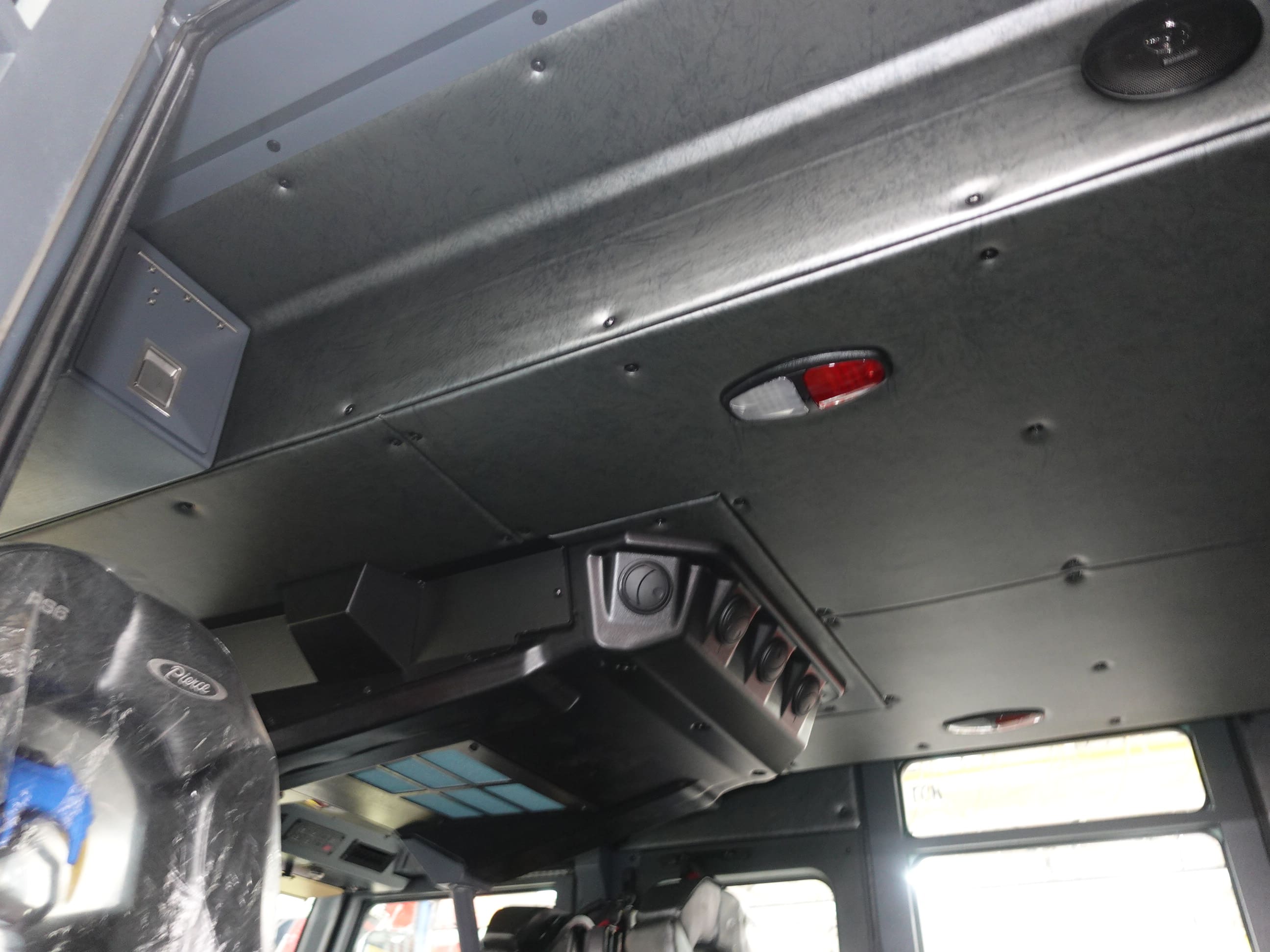

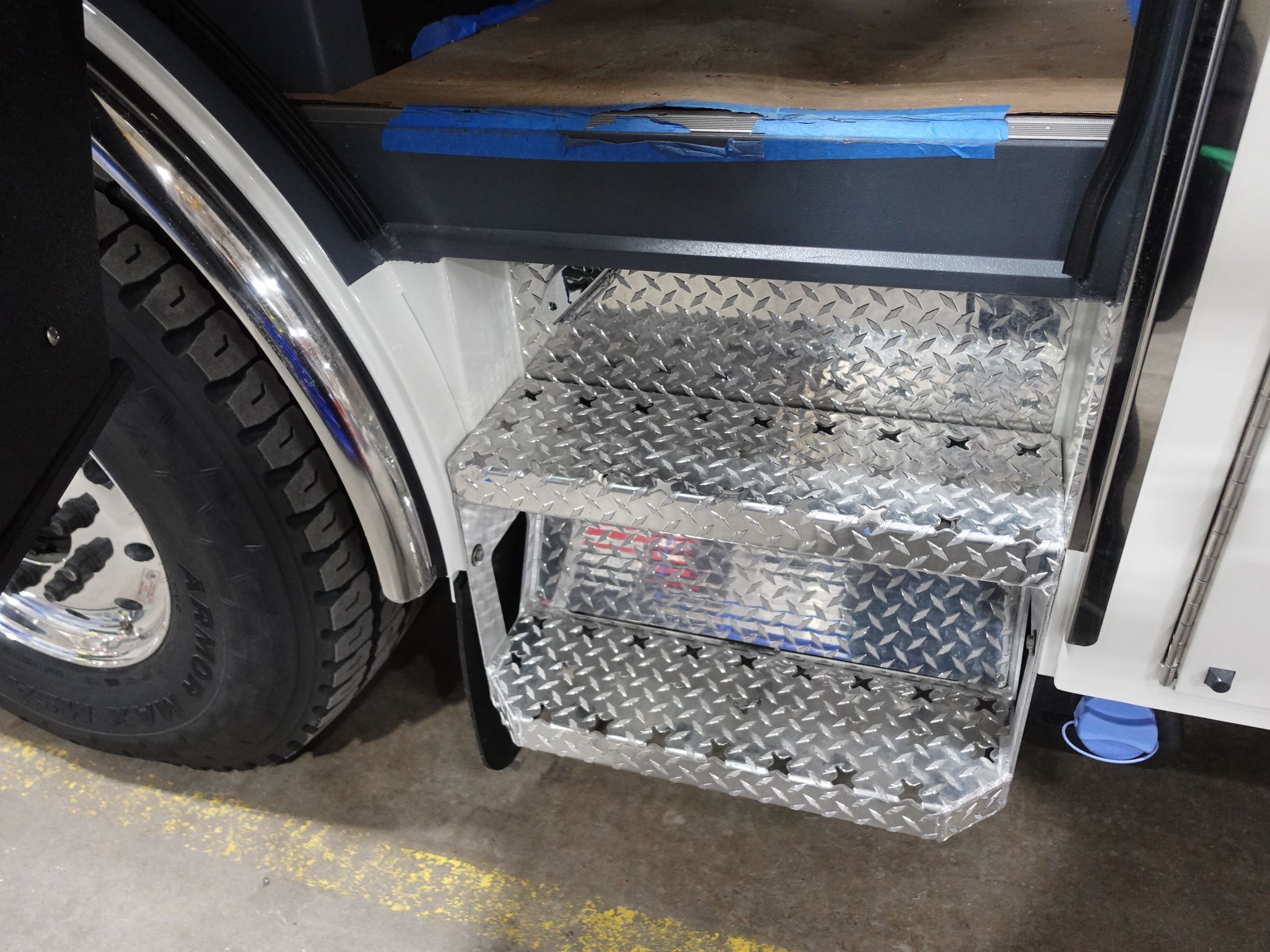

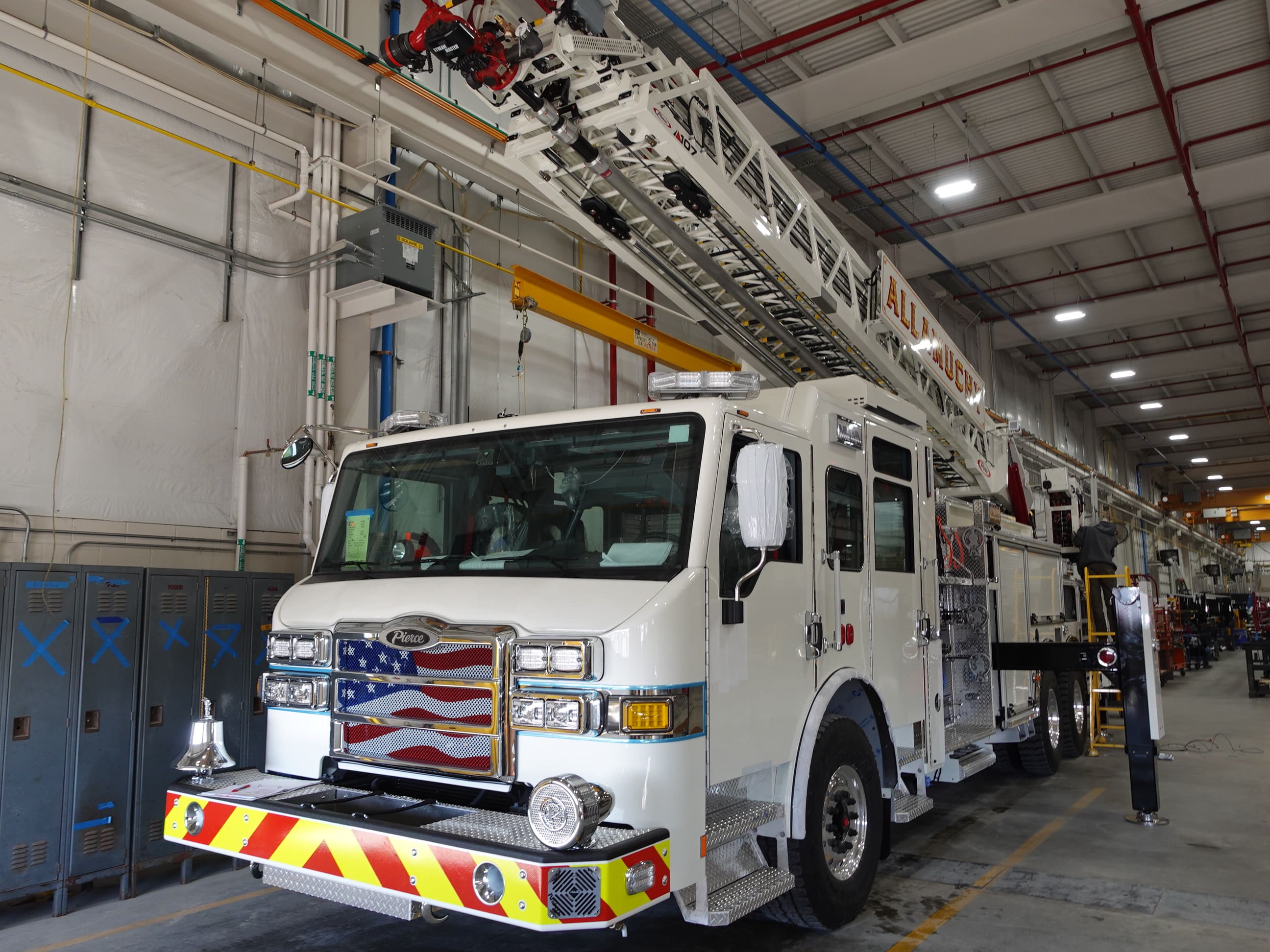

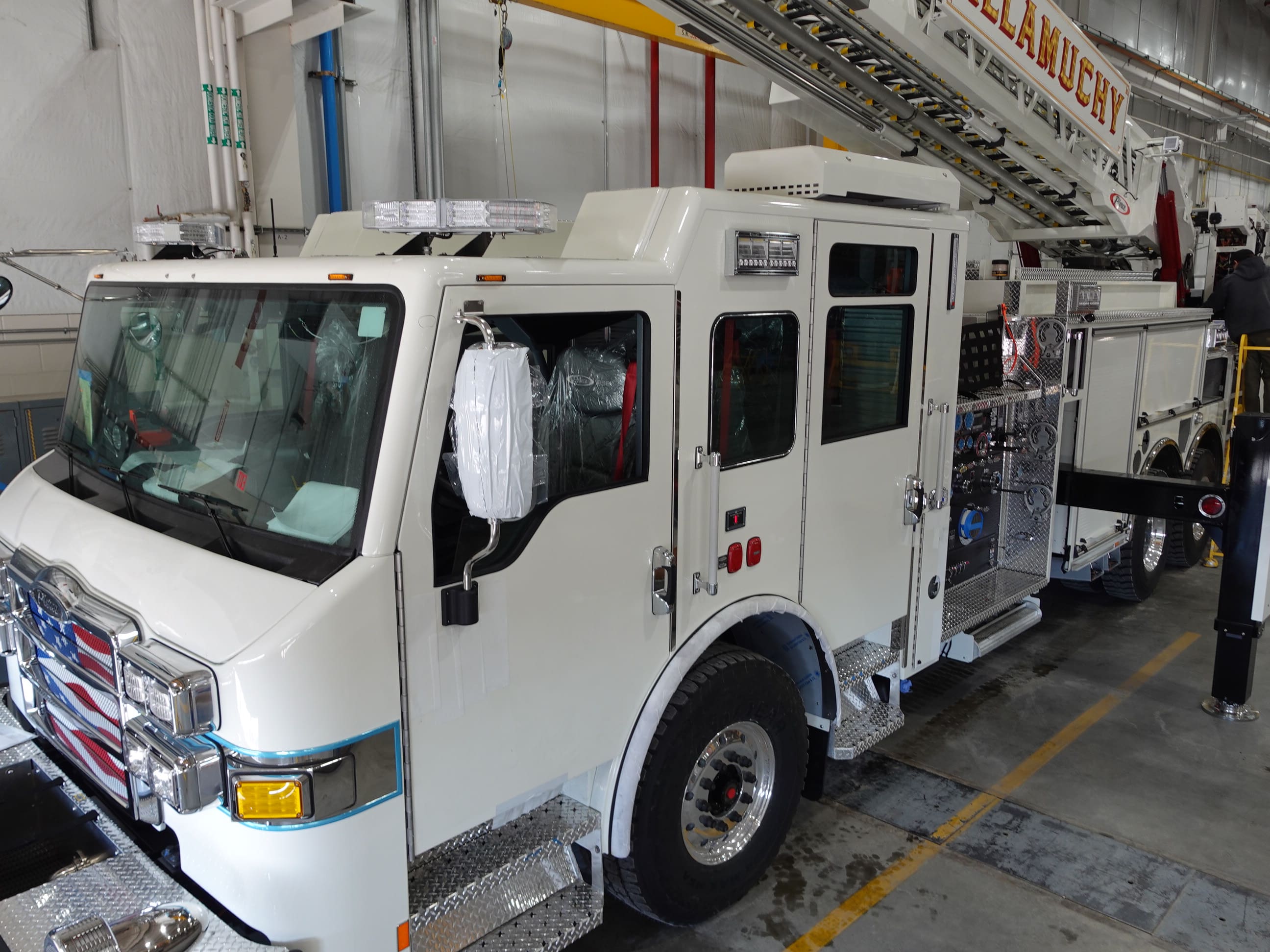

03-13-26

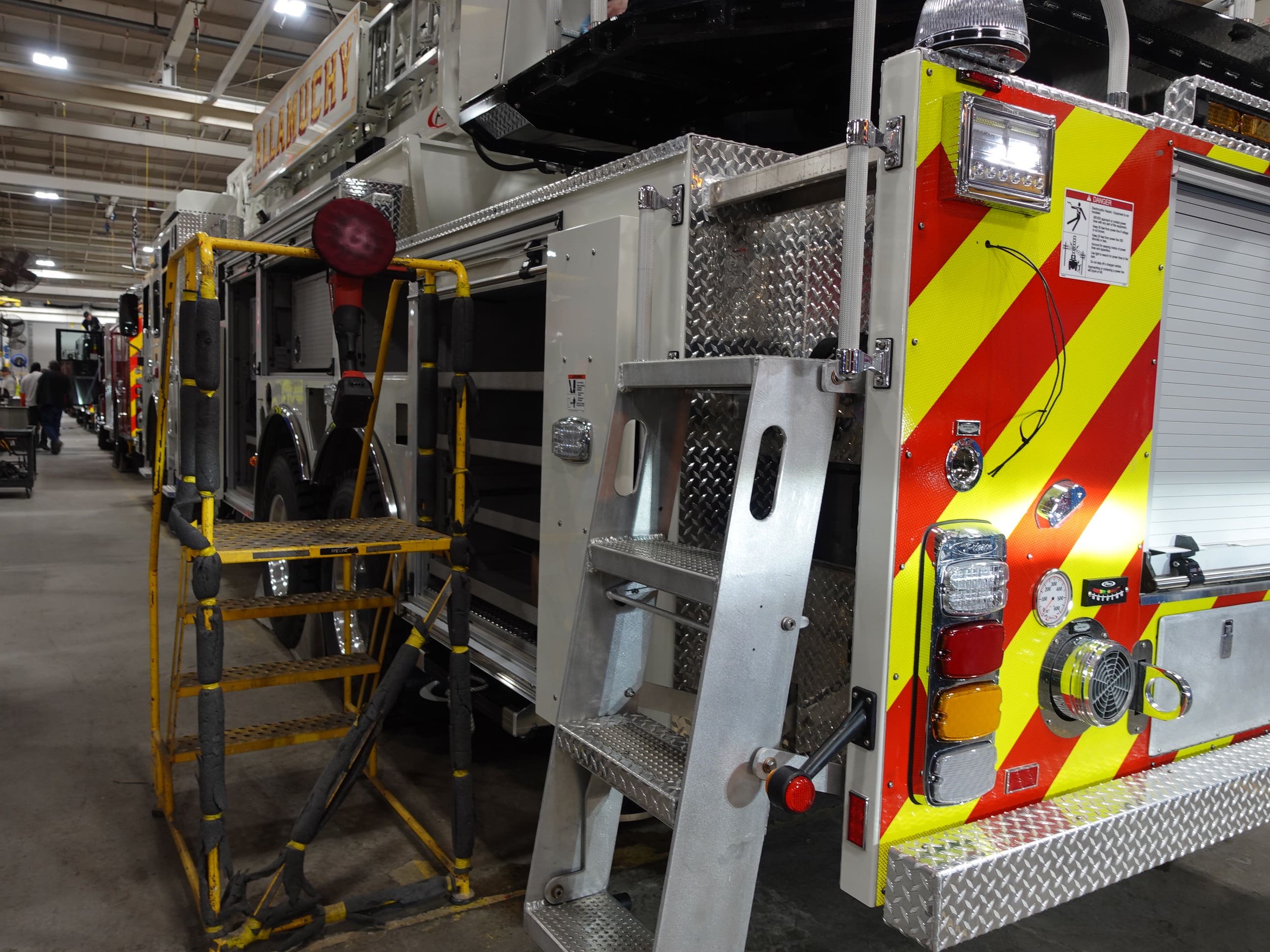

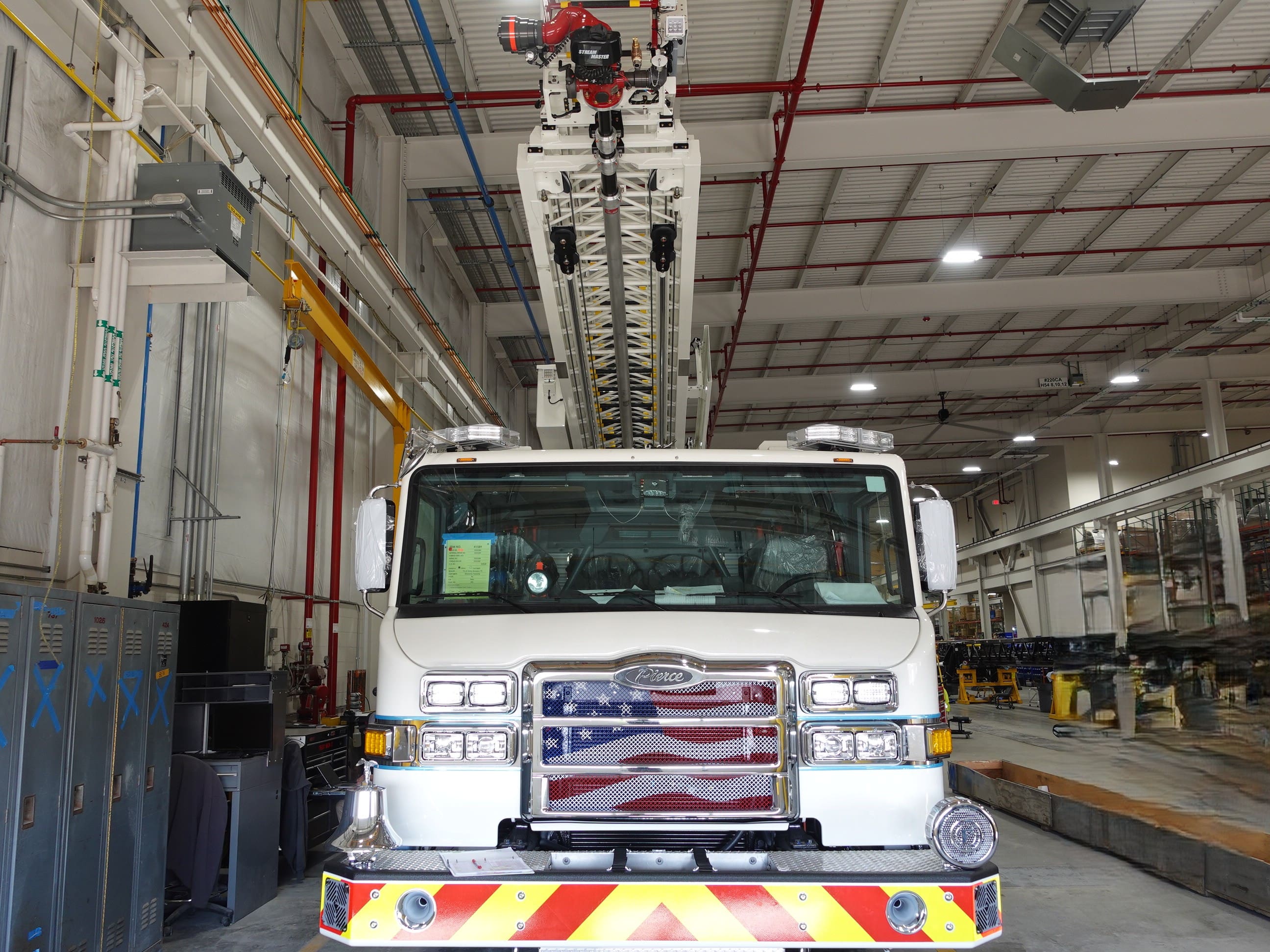

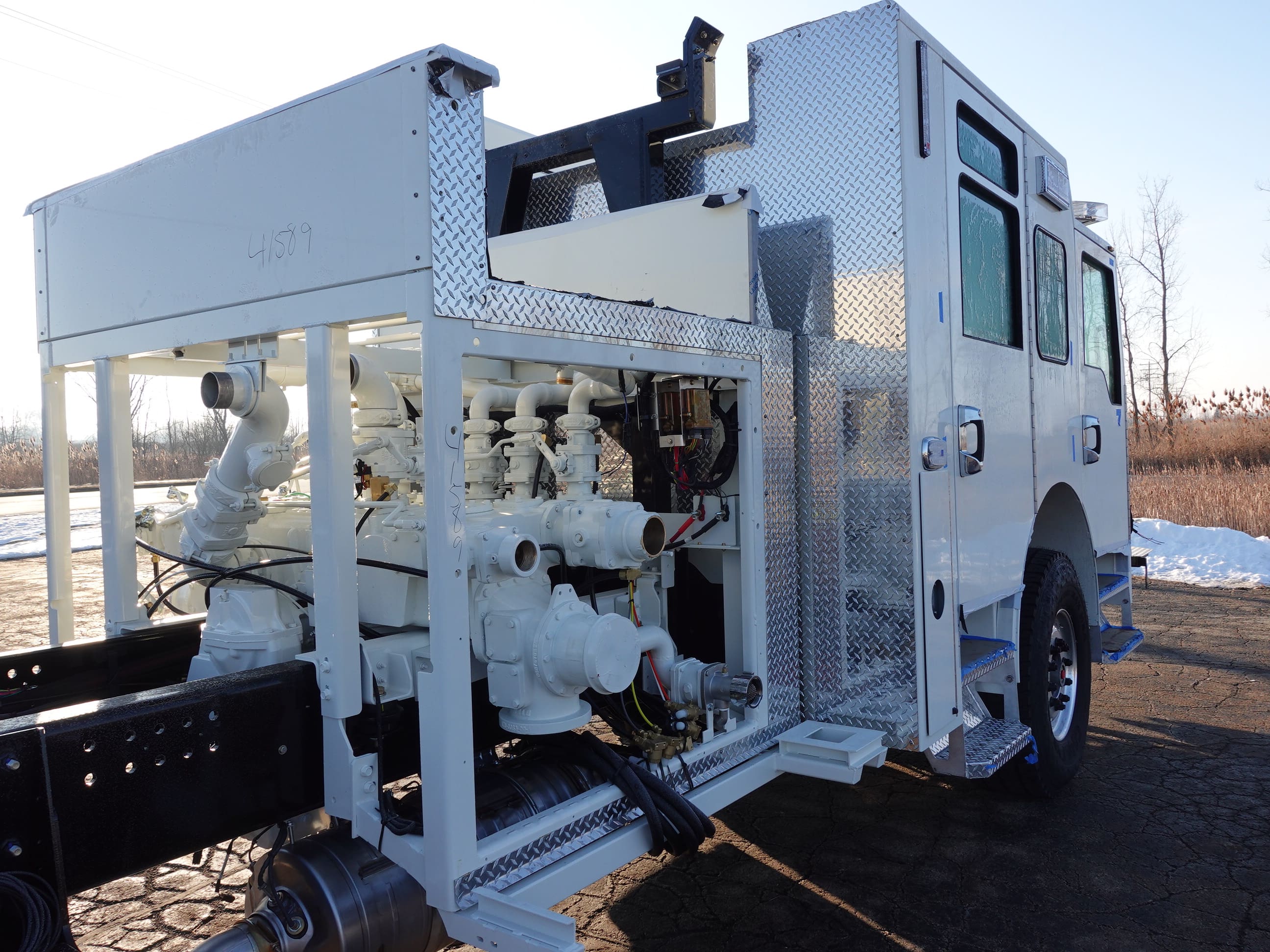

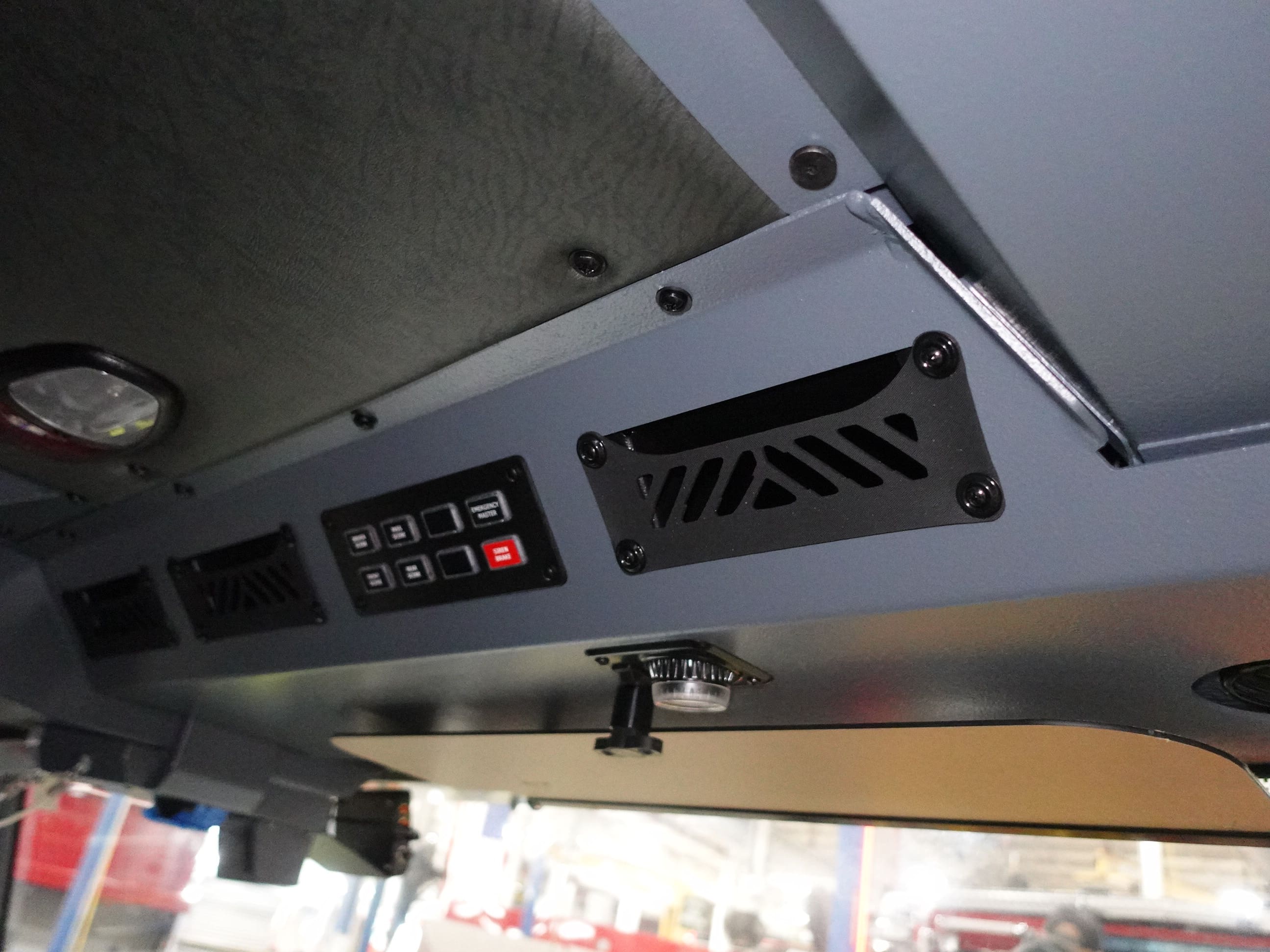

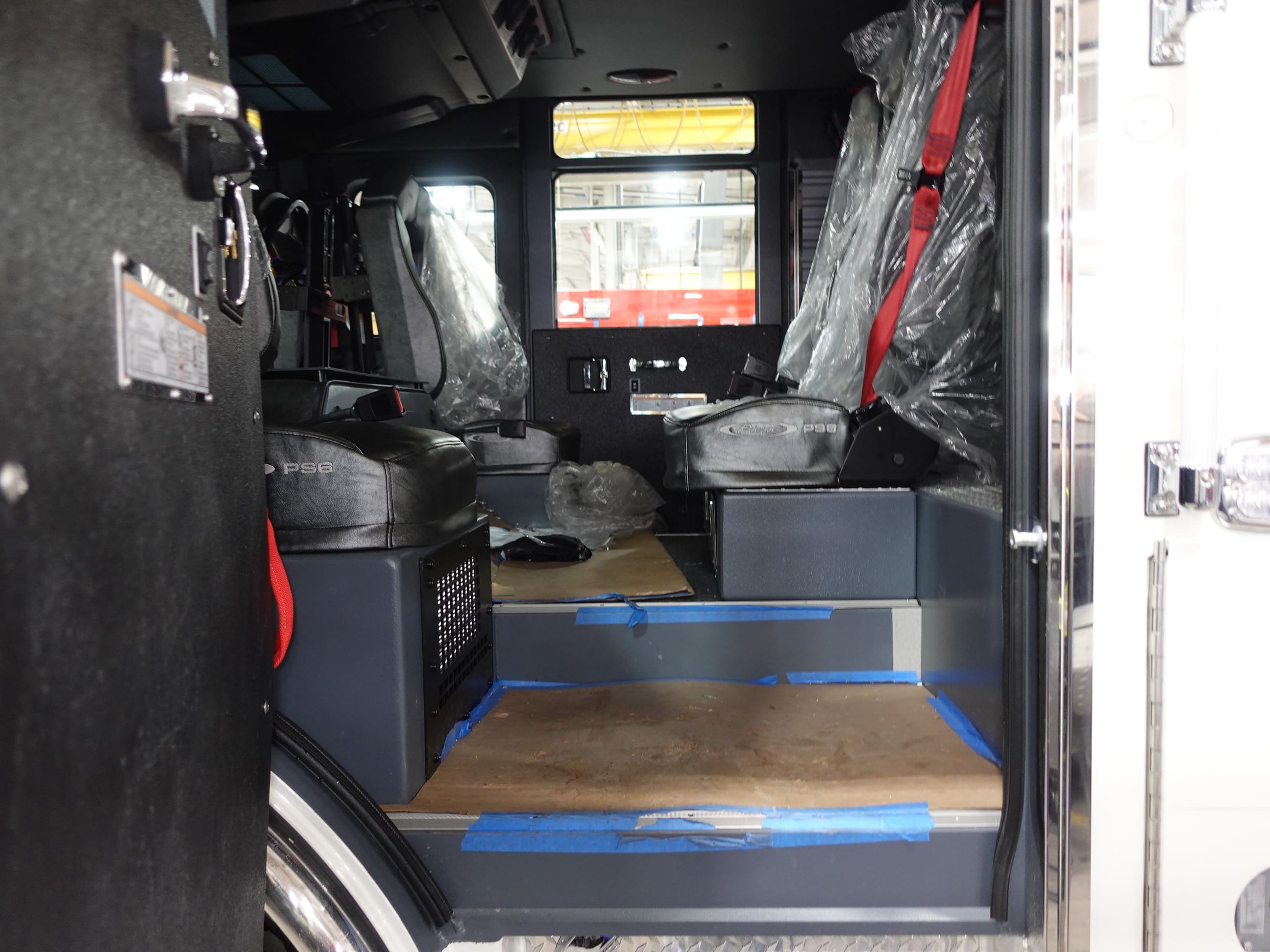

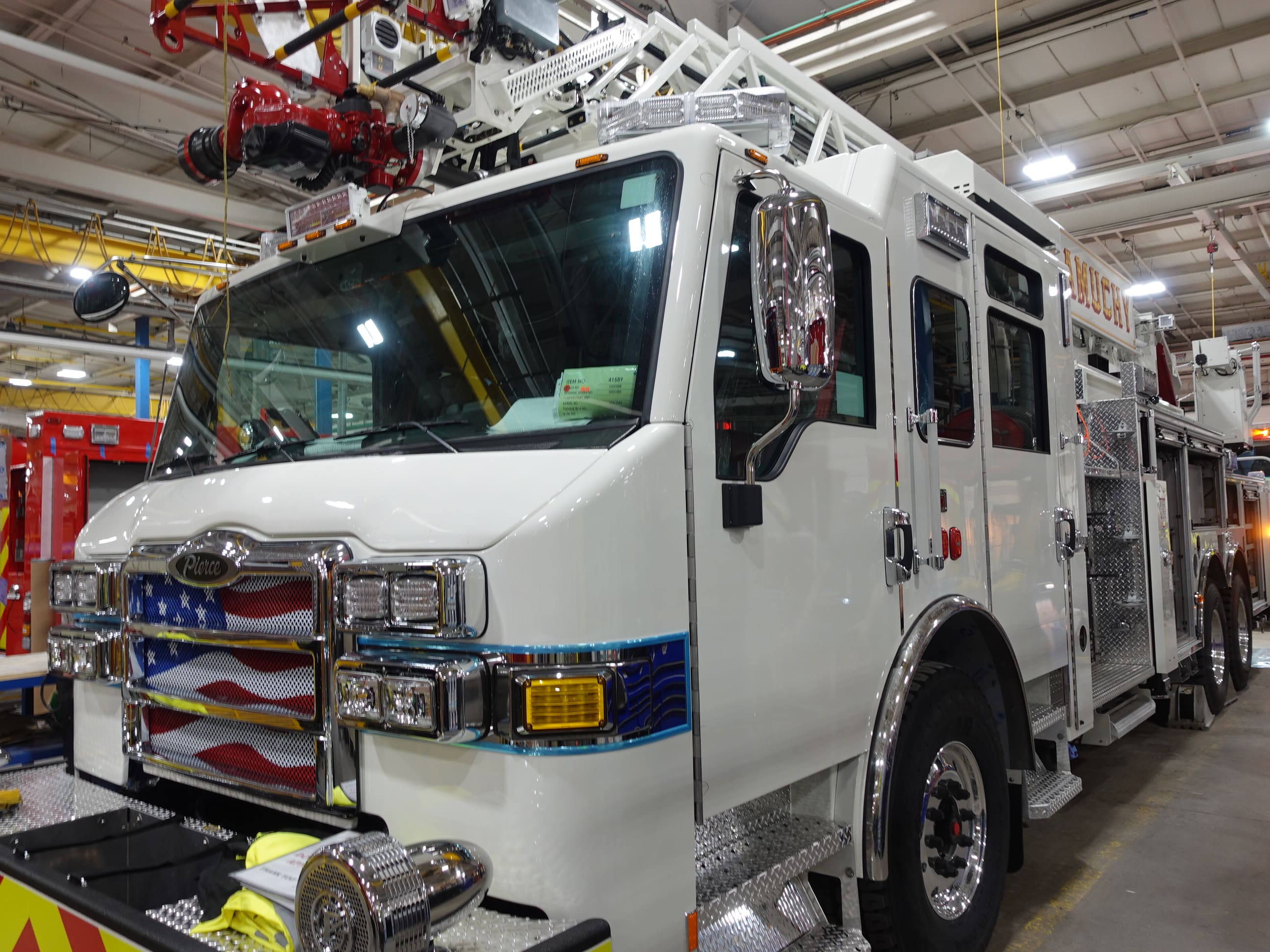

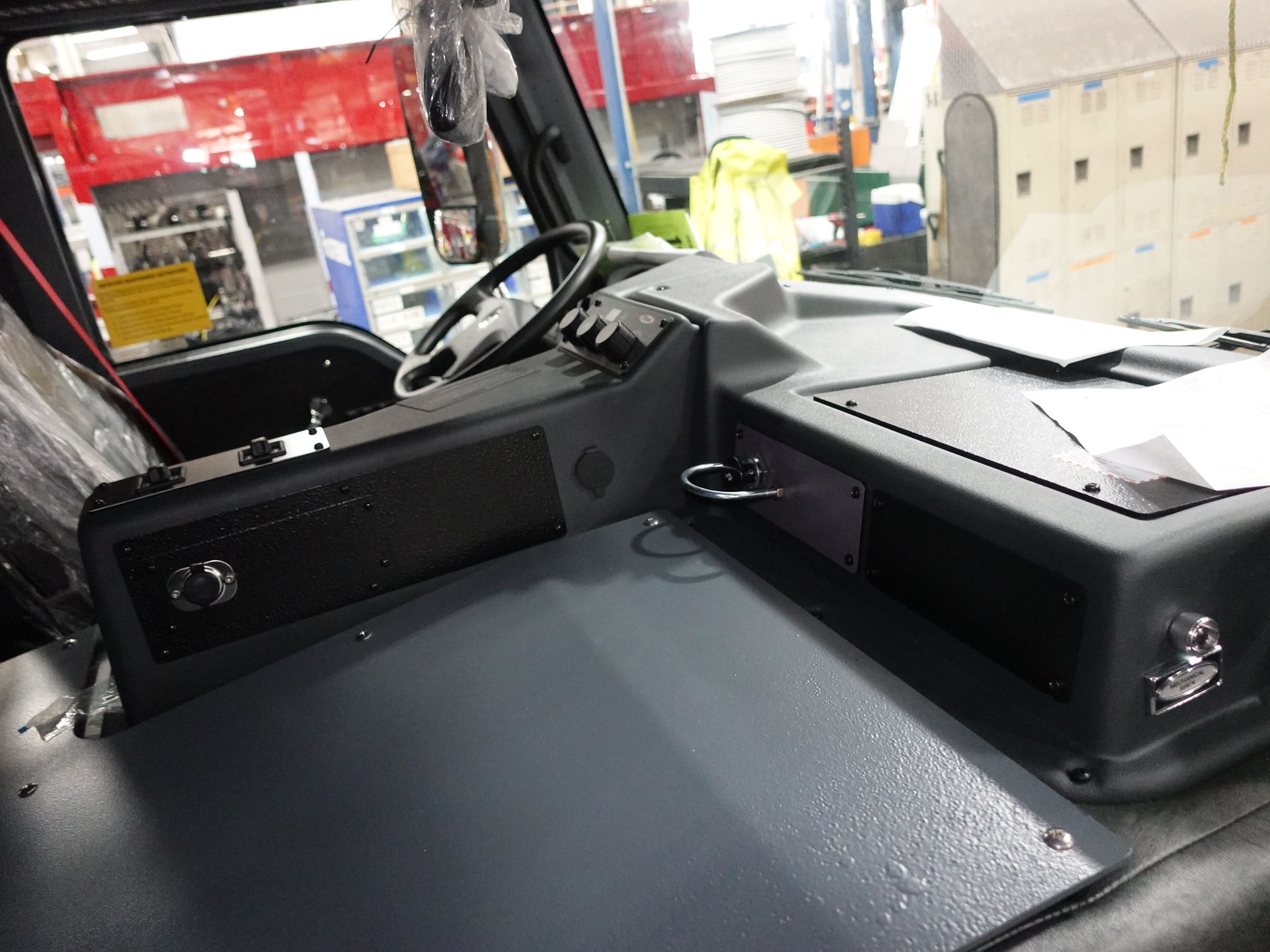

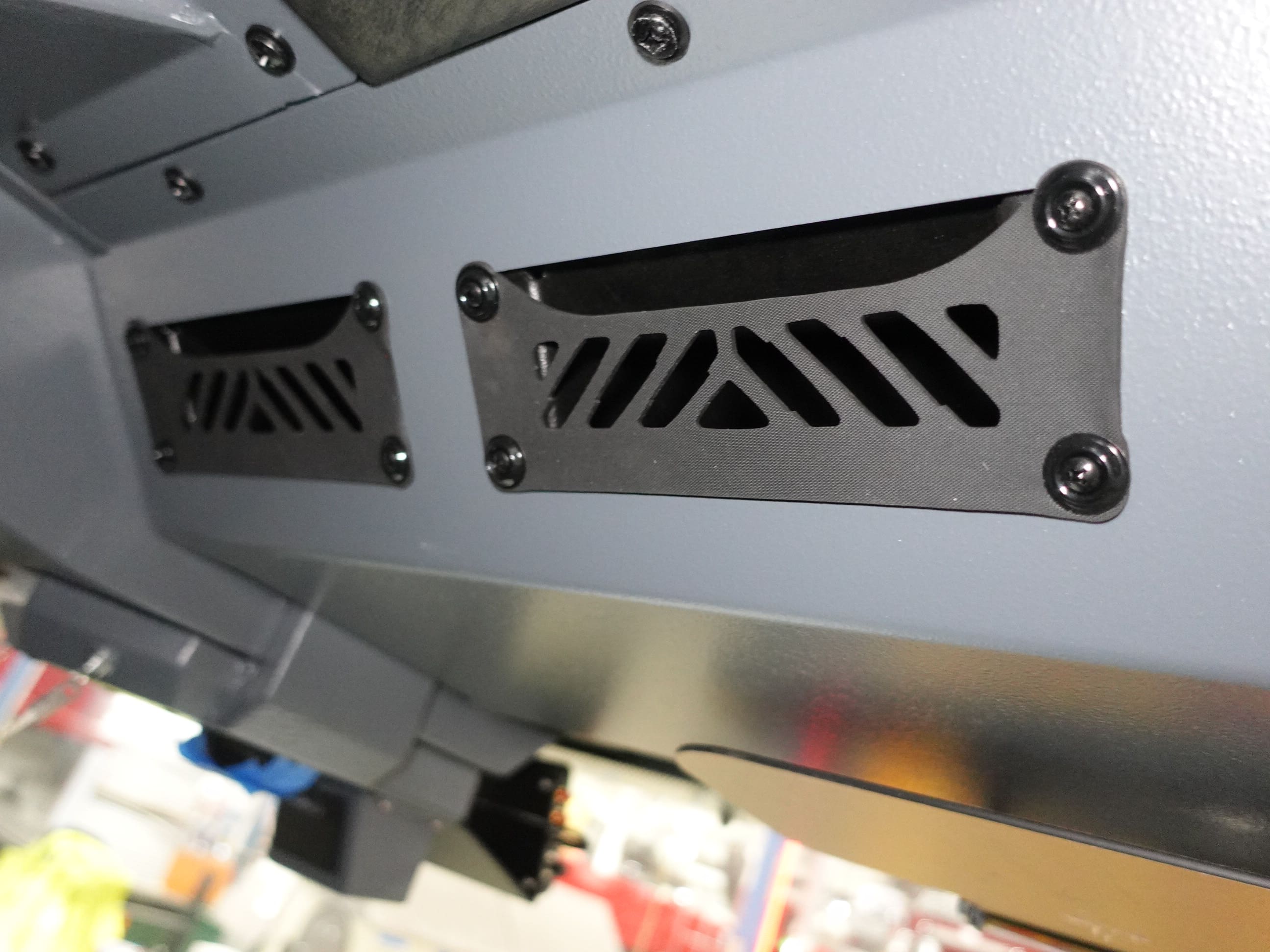

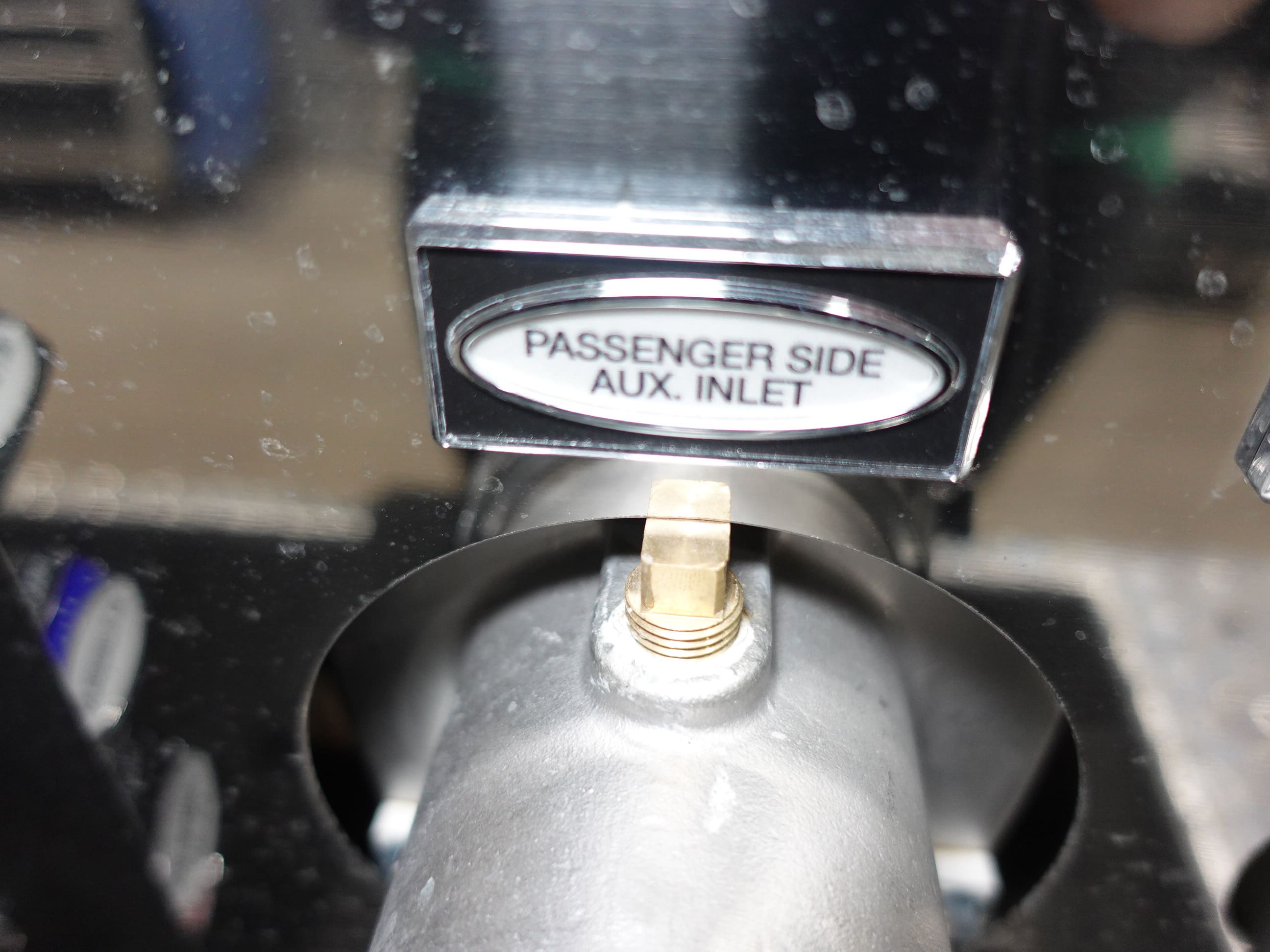

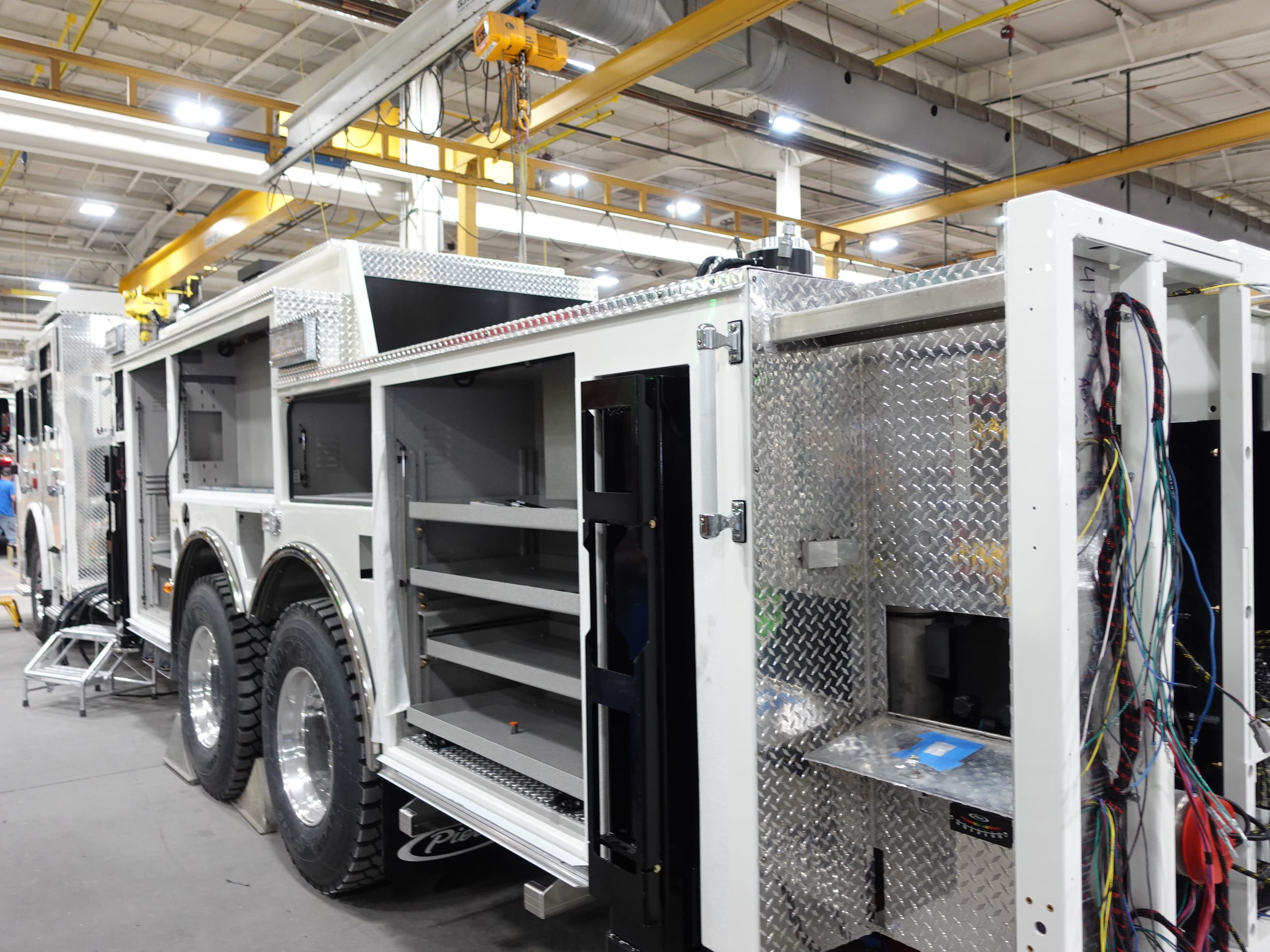

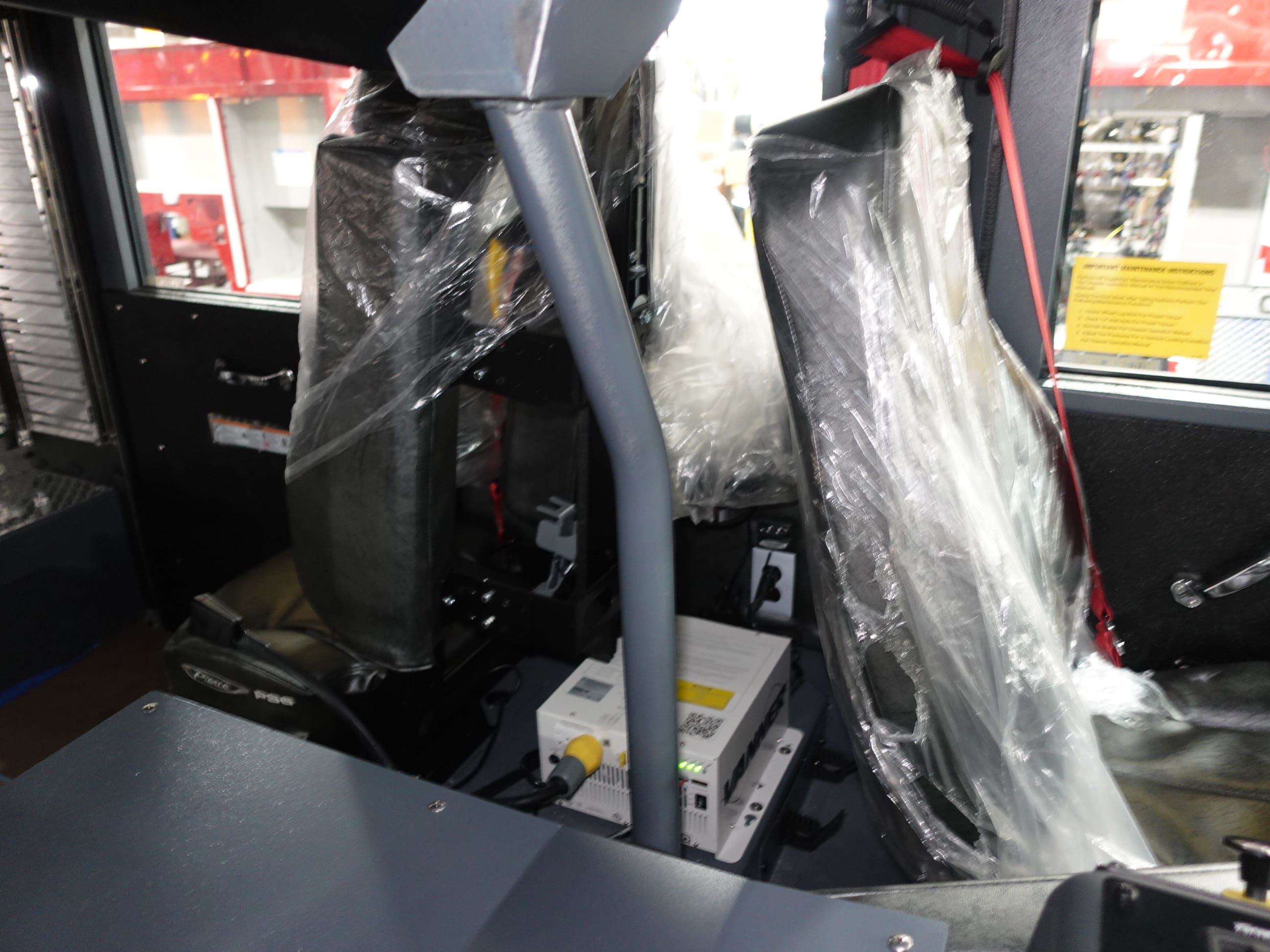

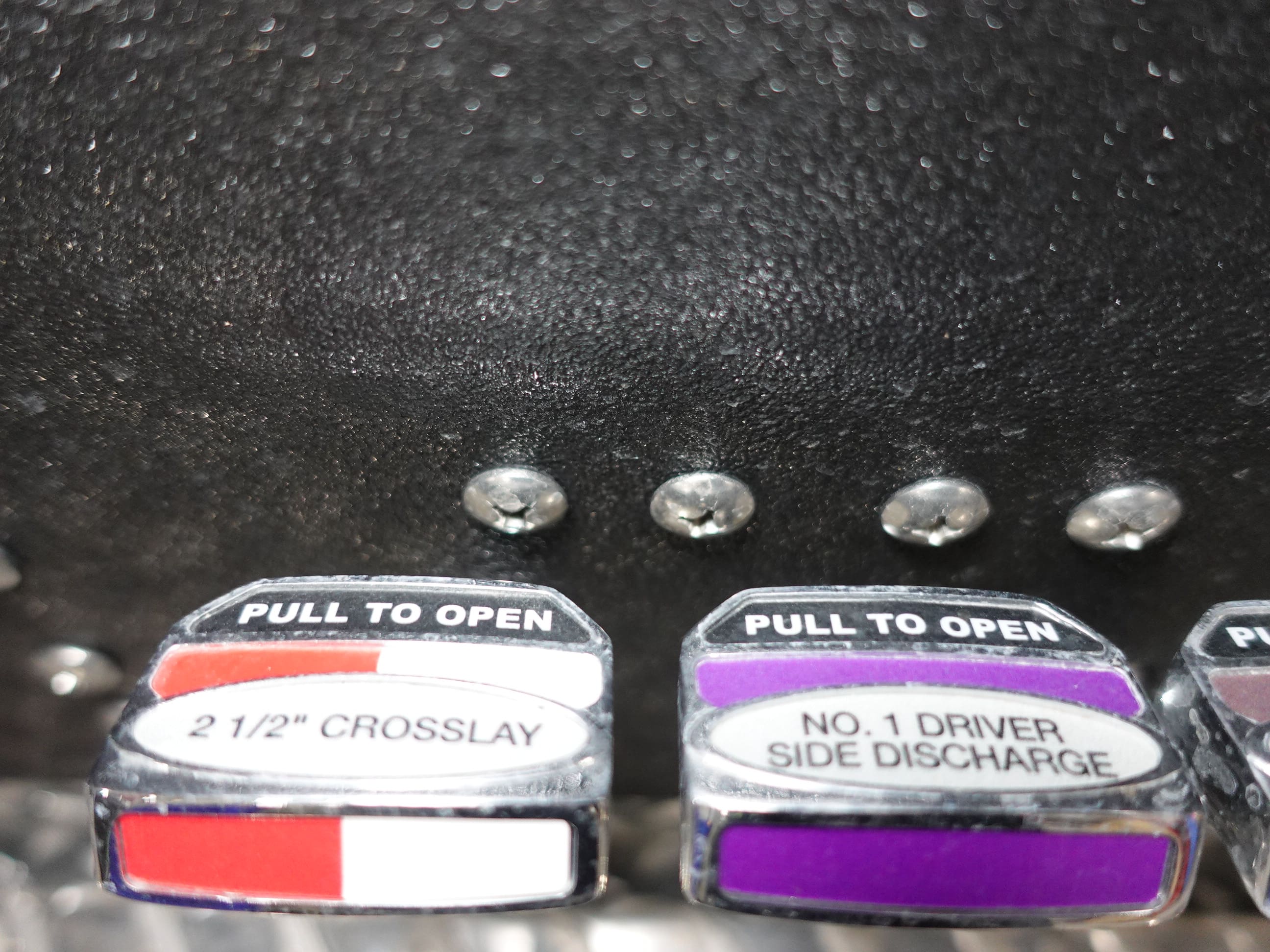

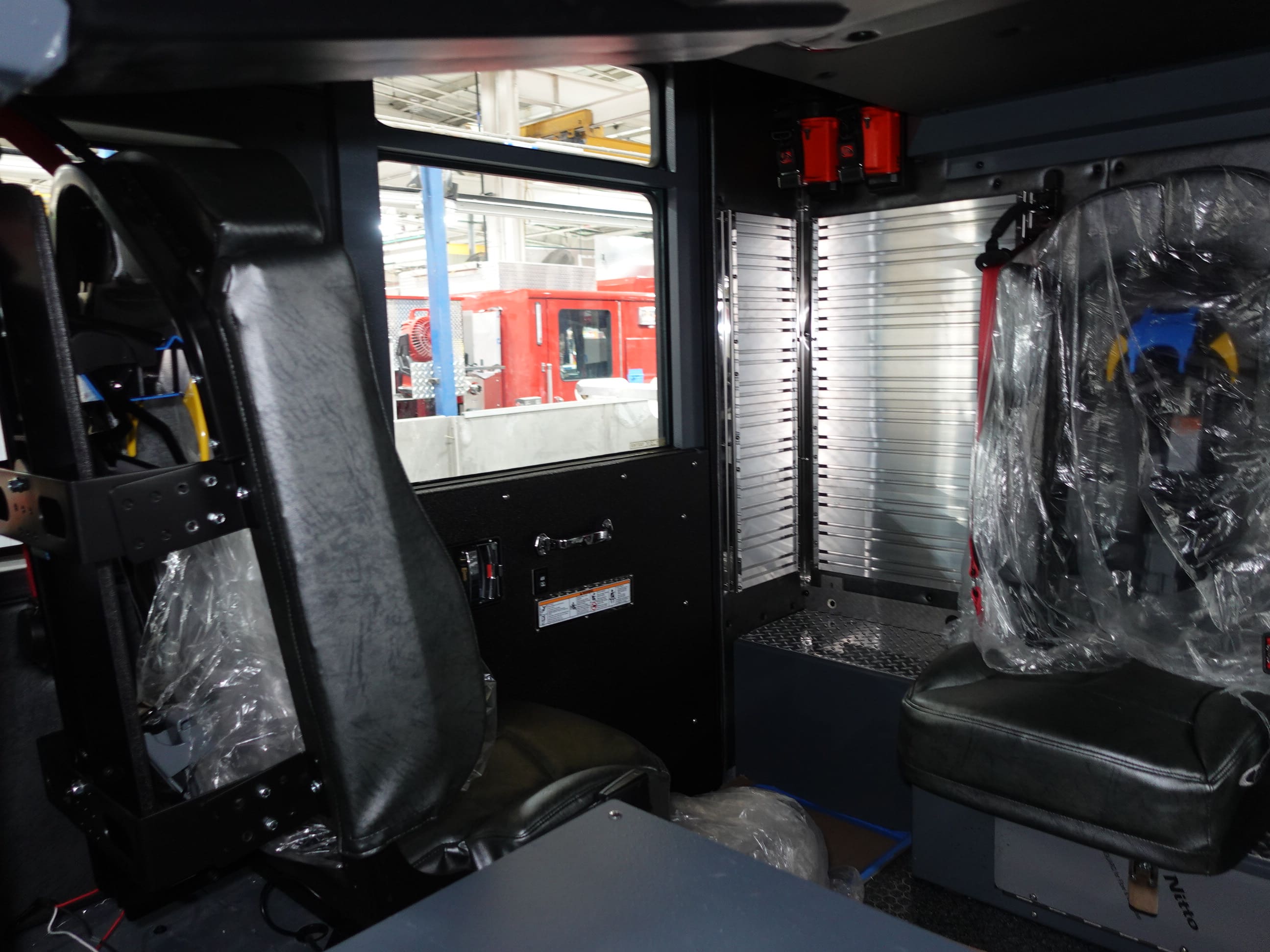

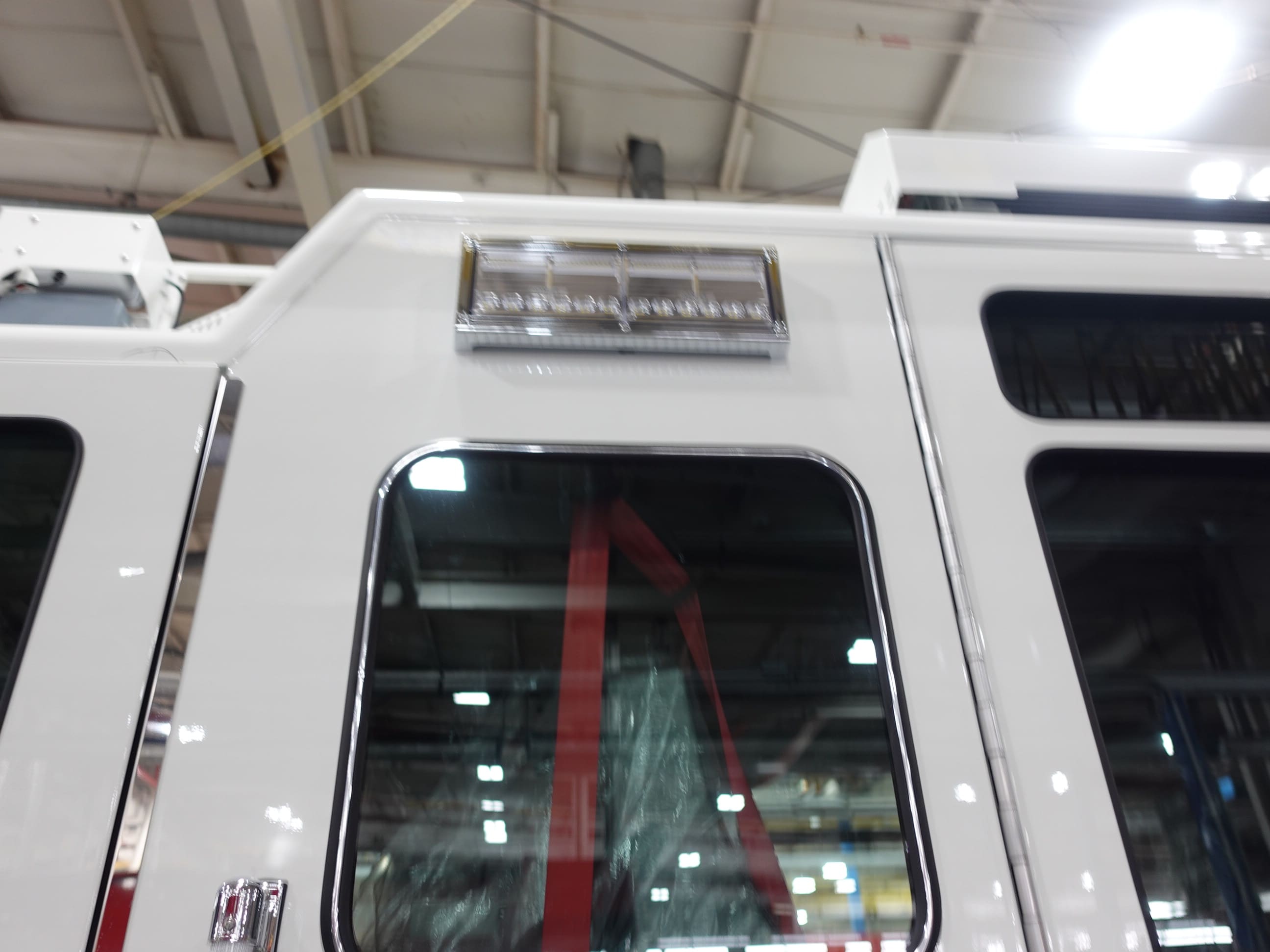

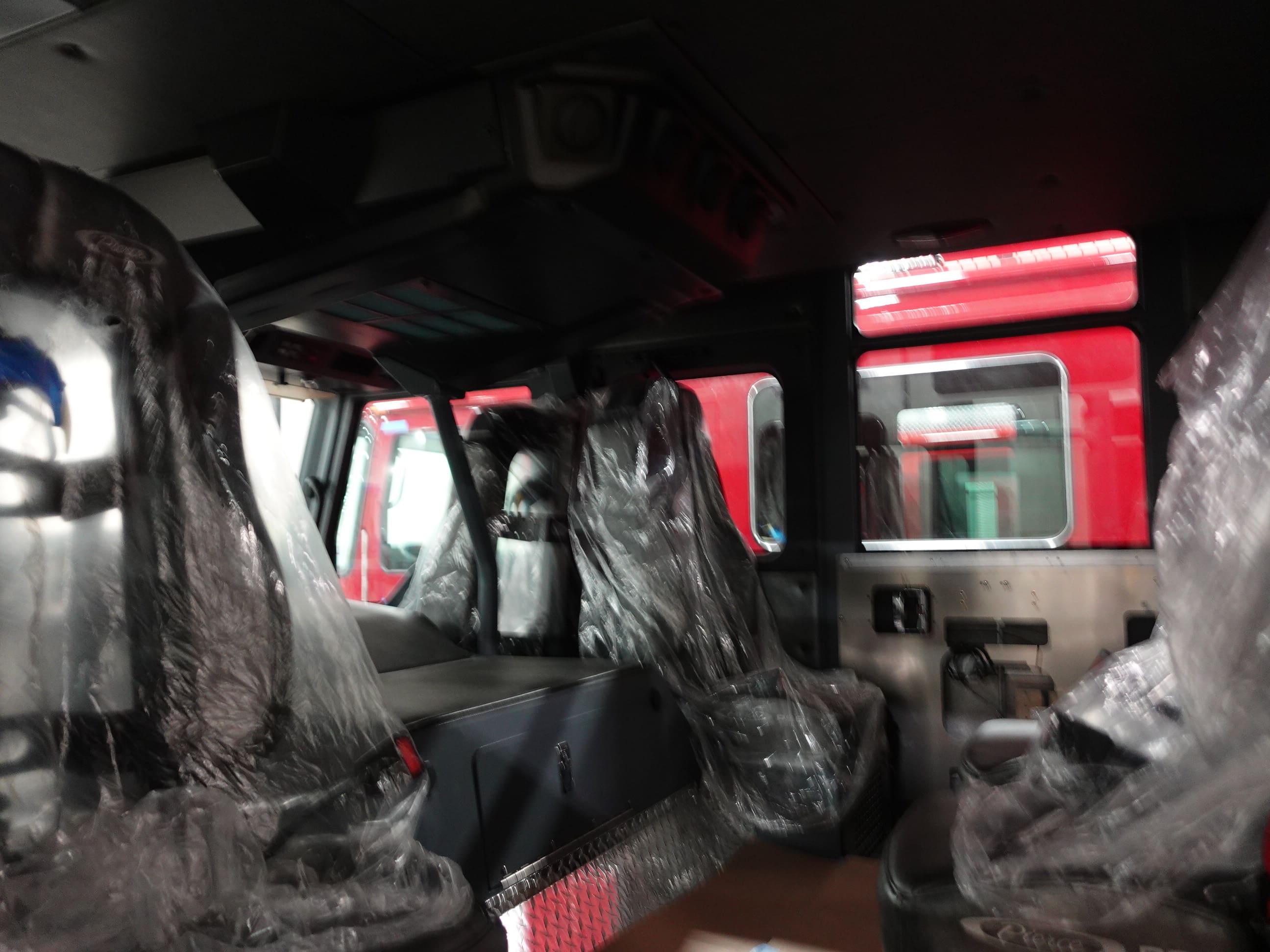

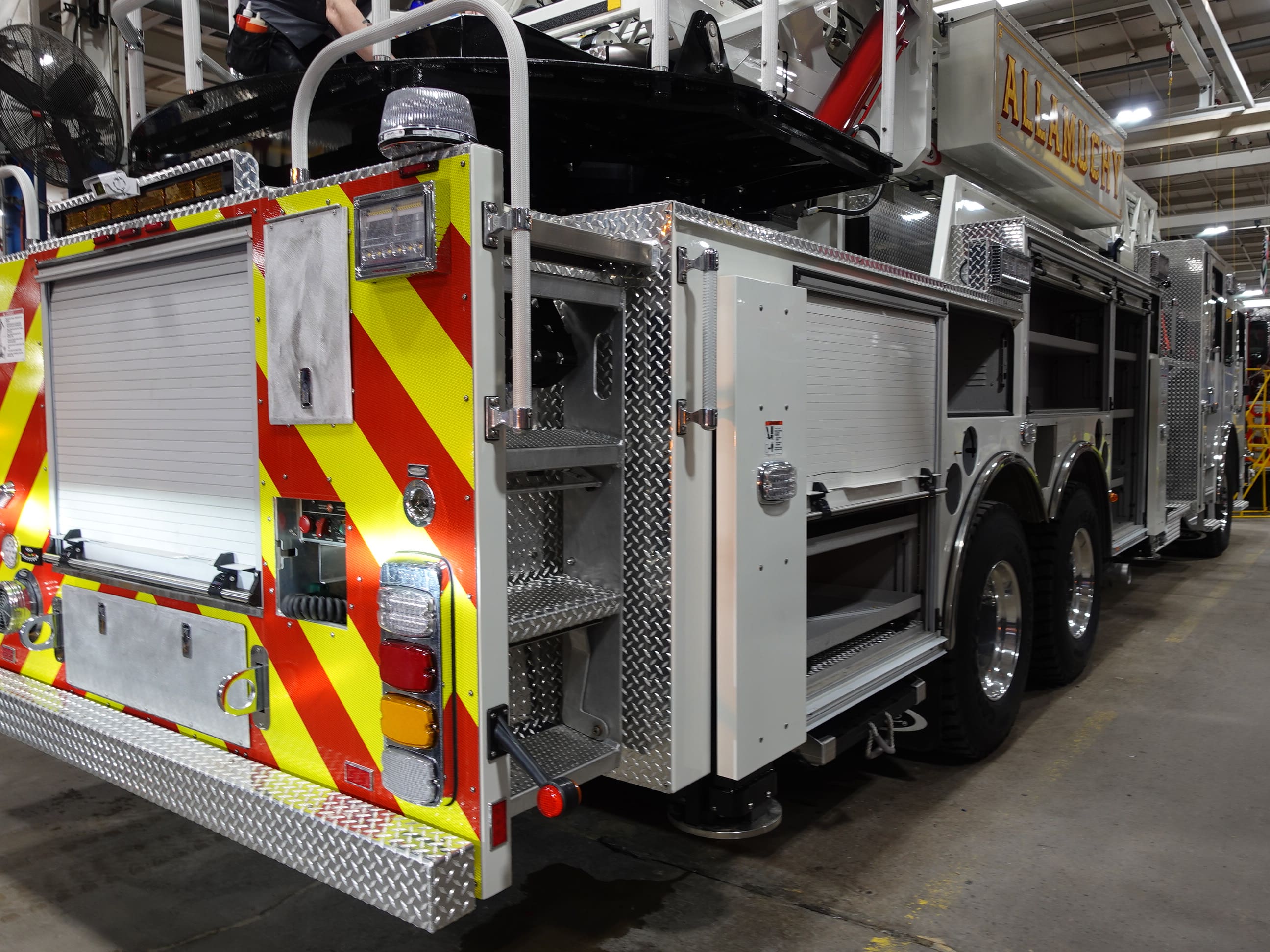

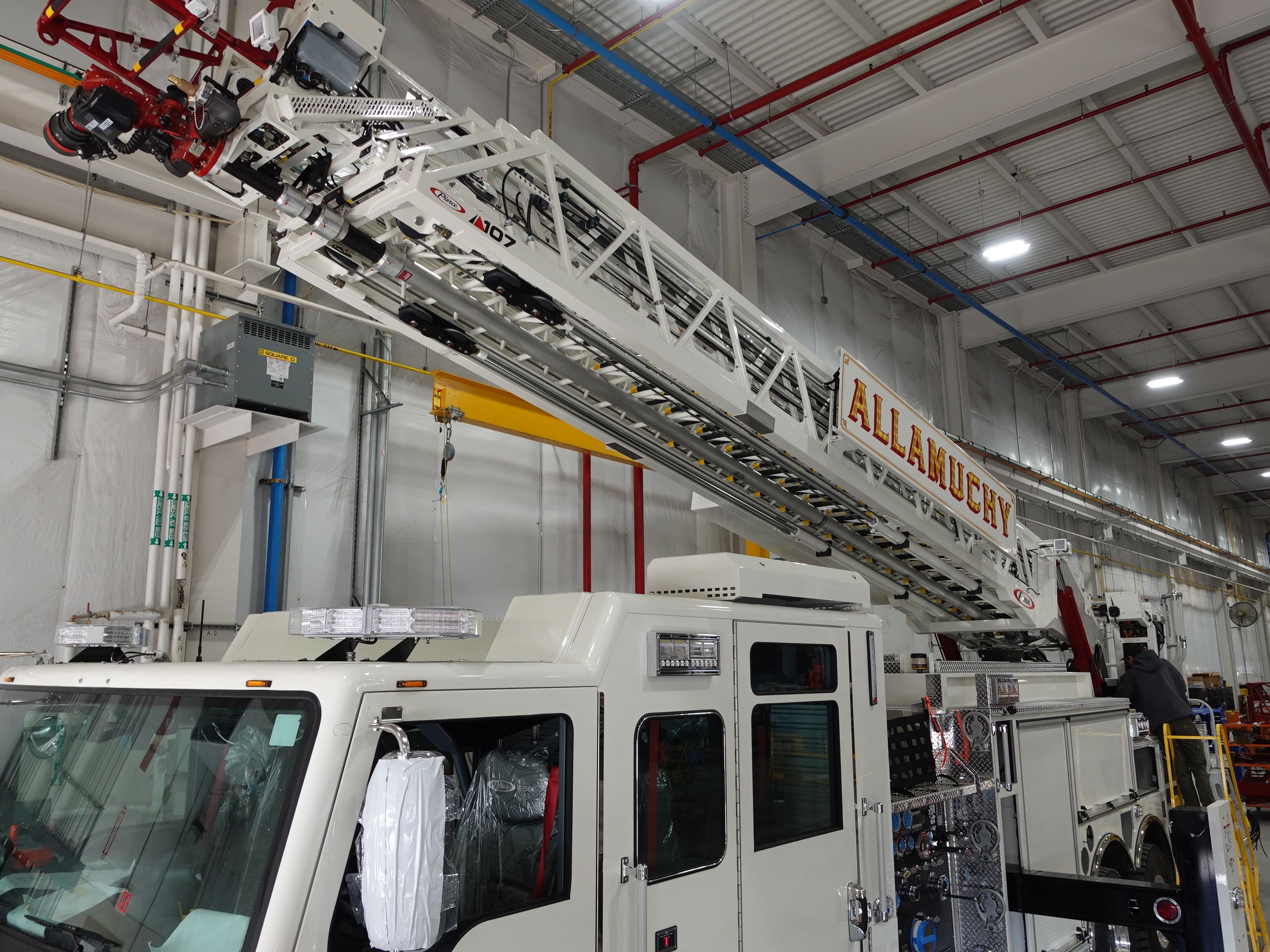

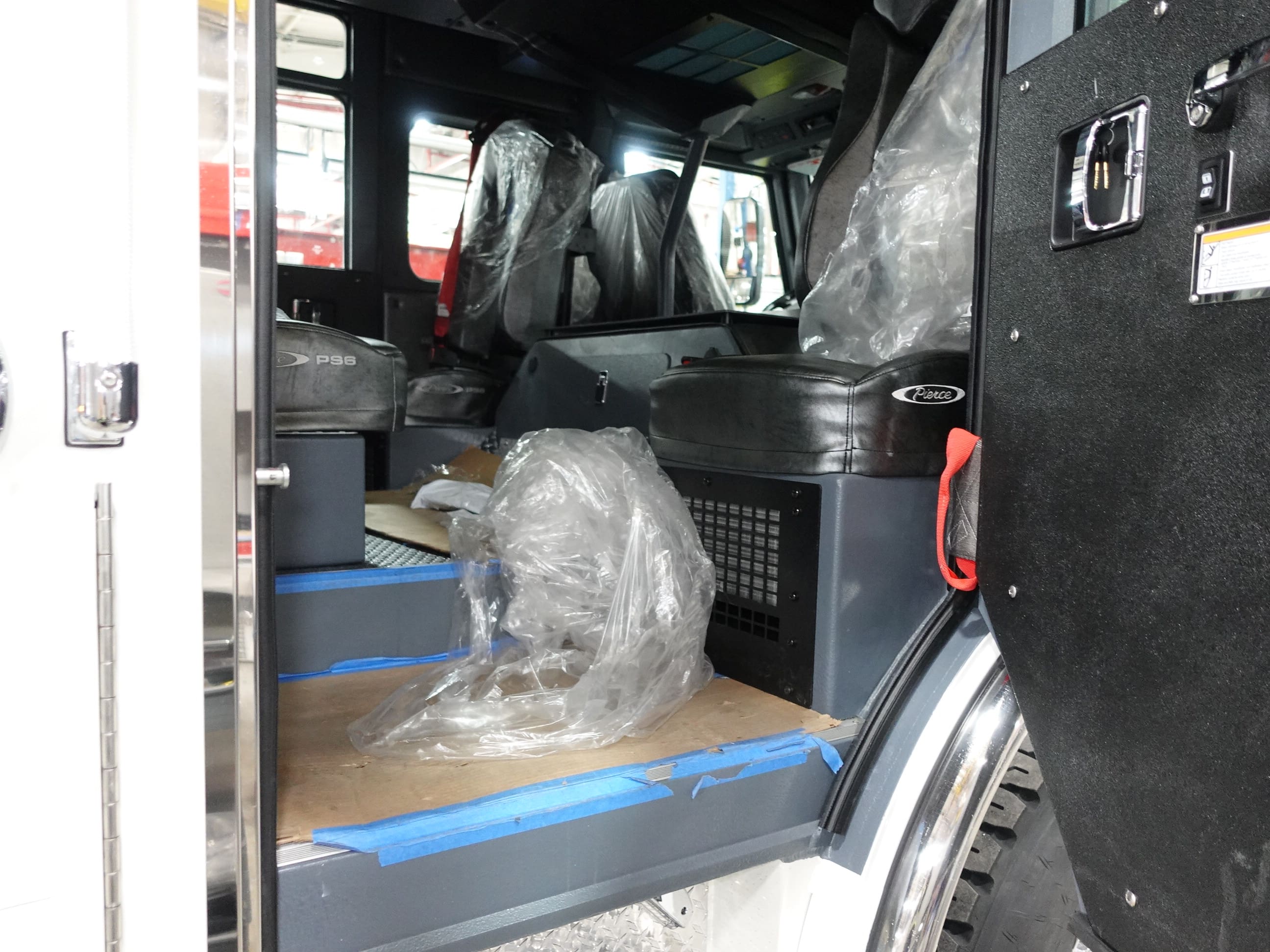

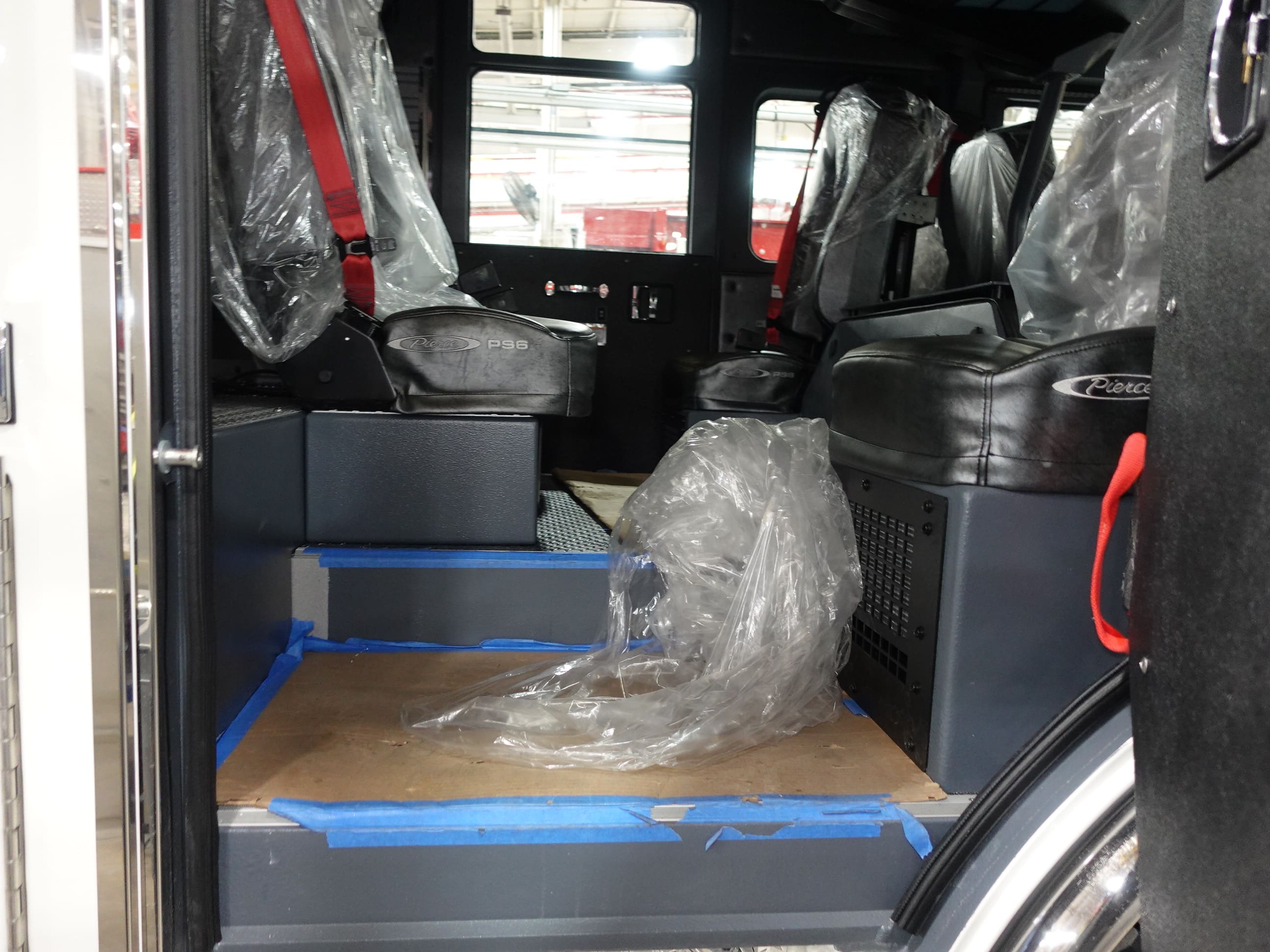

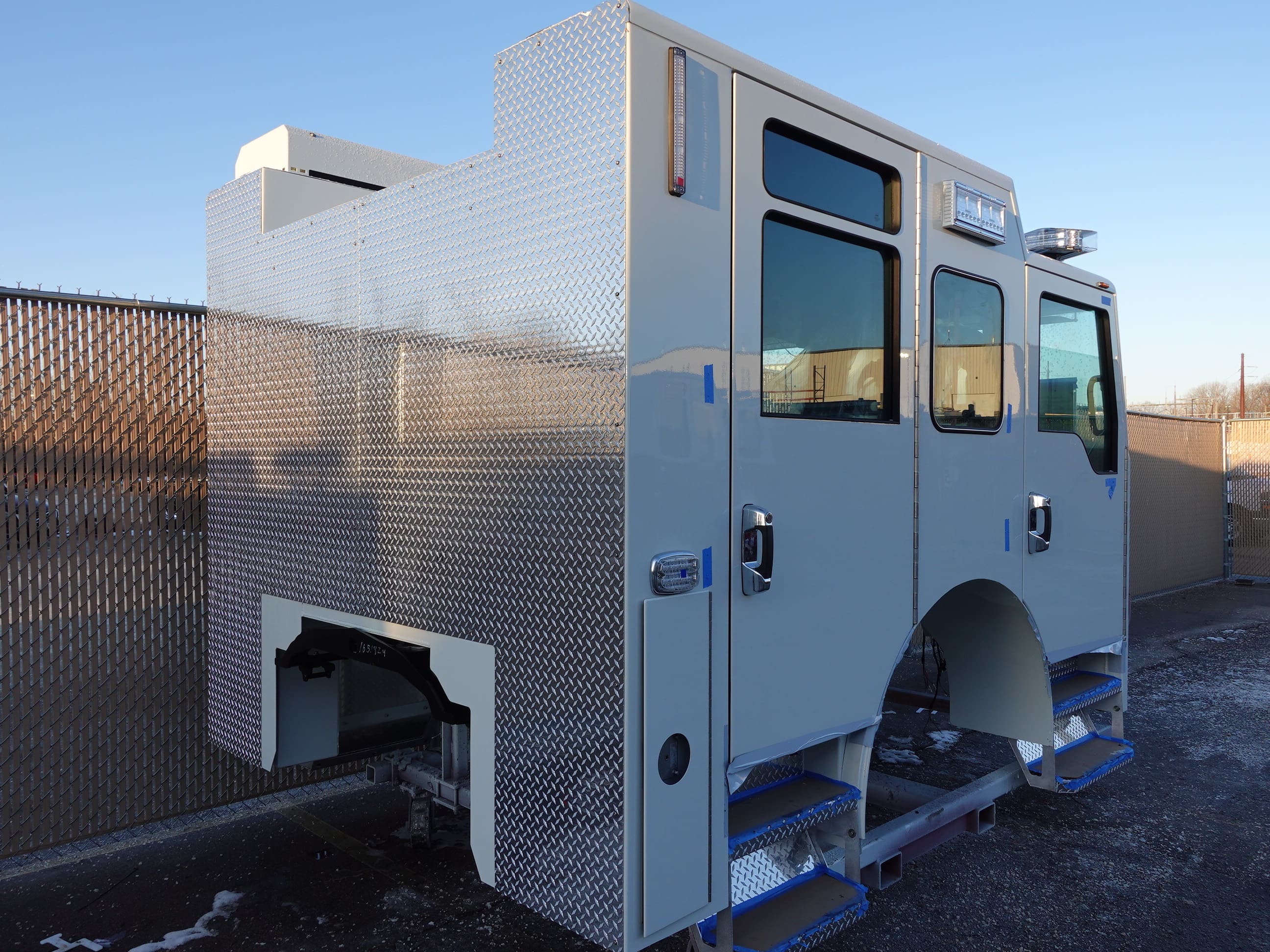

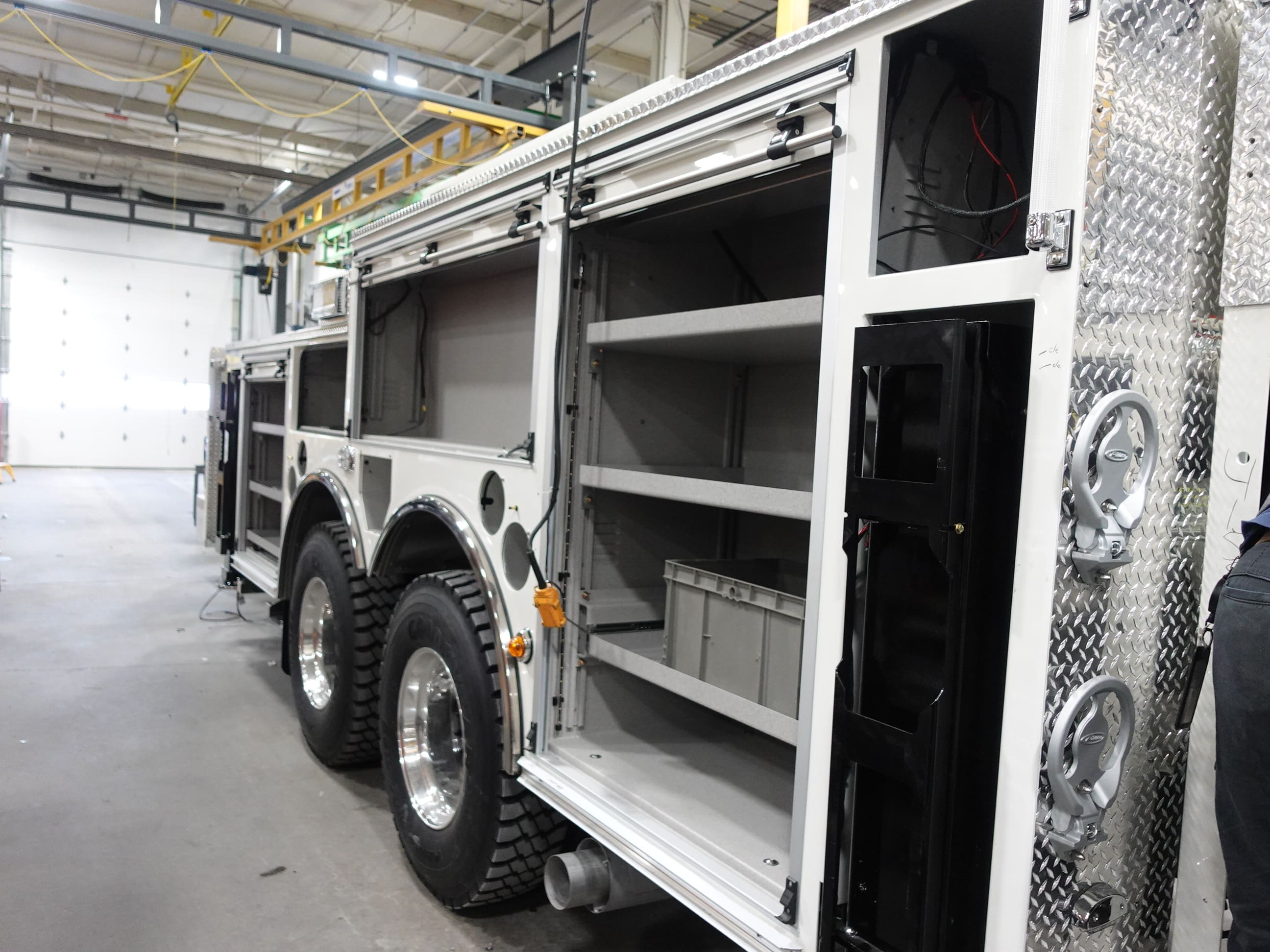

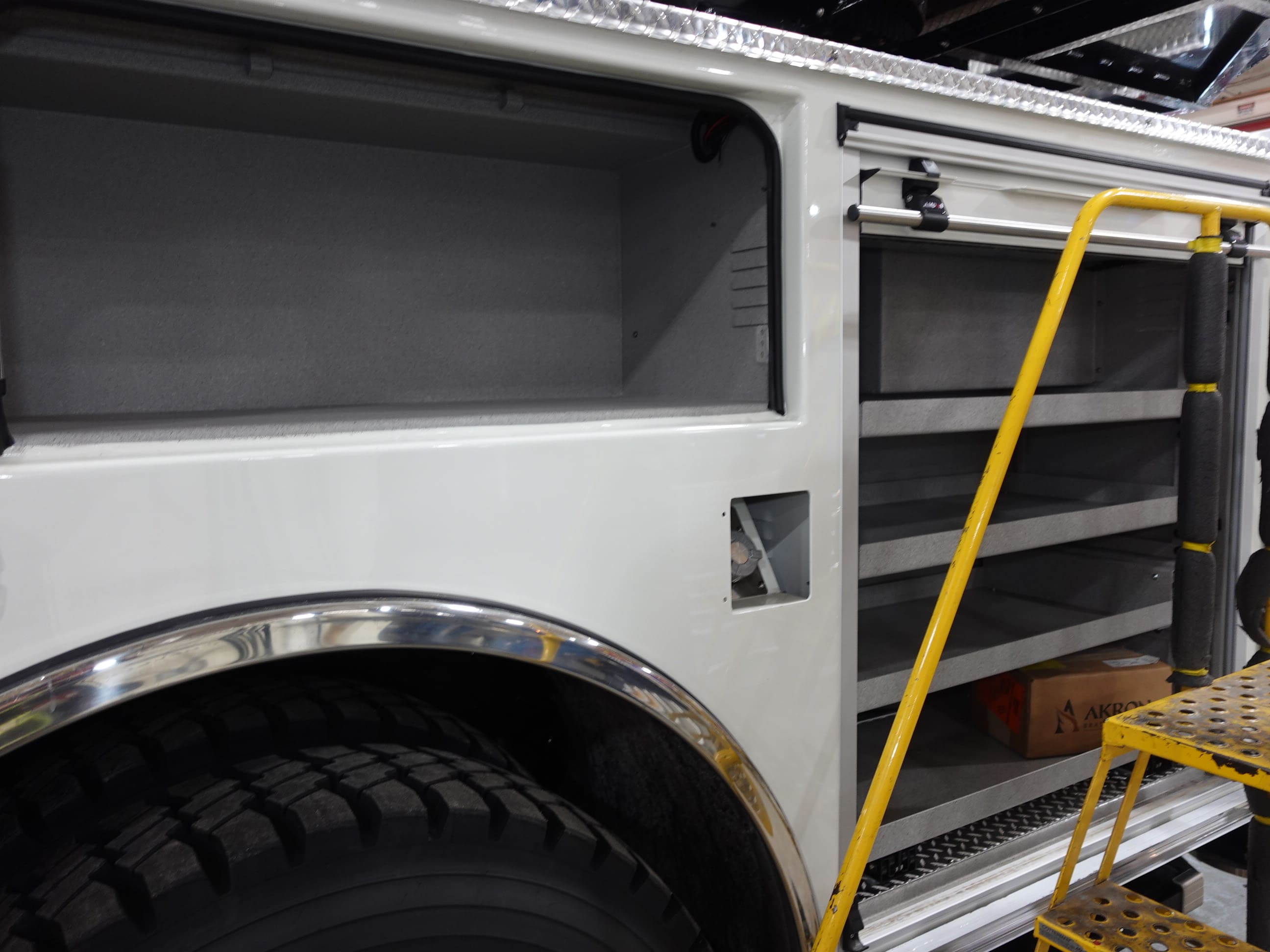

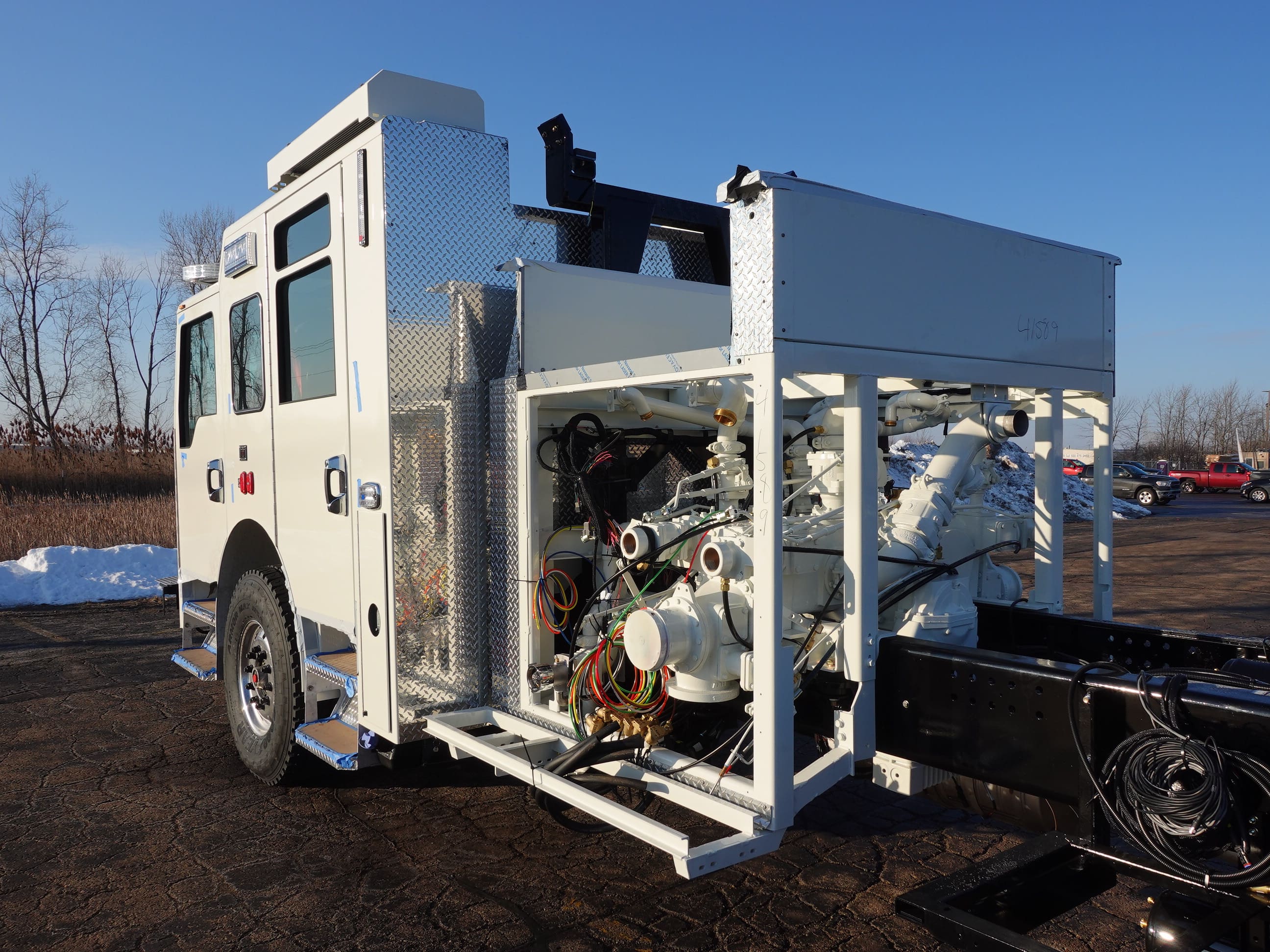

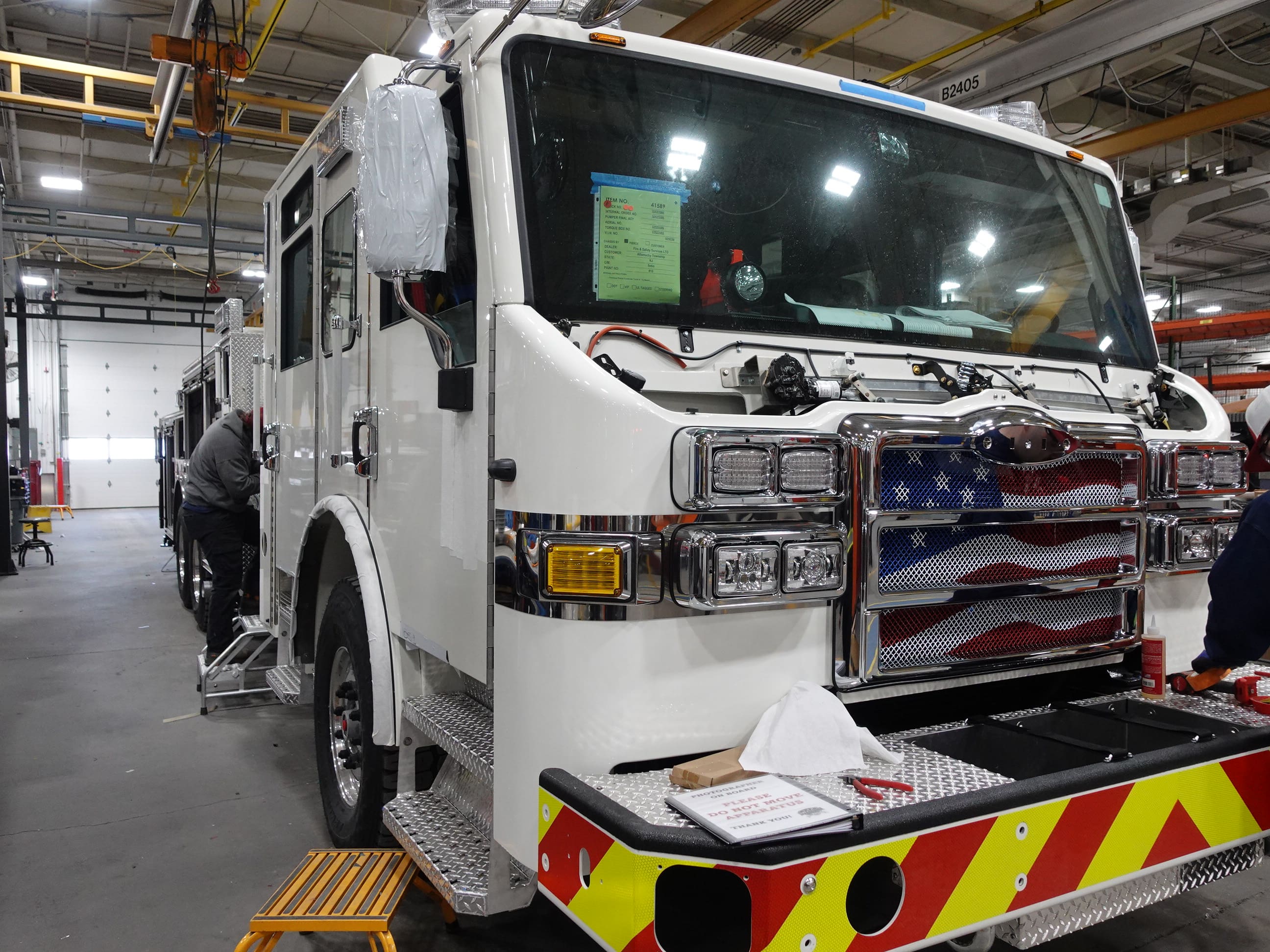

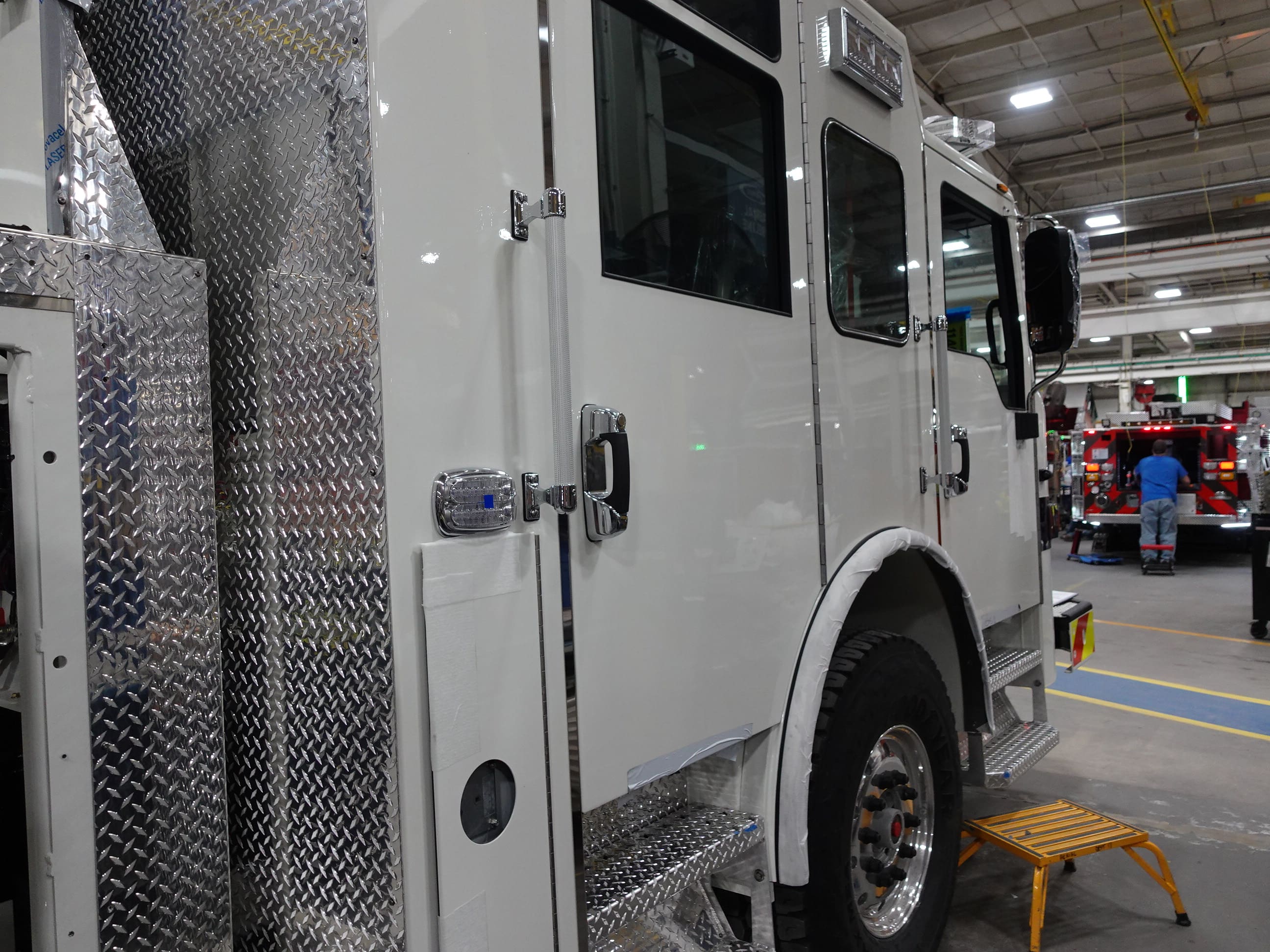

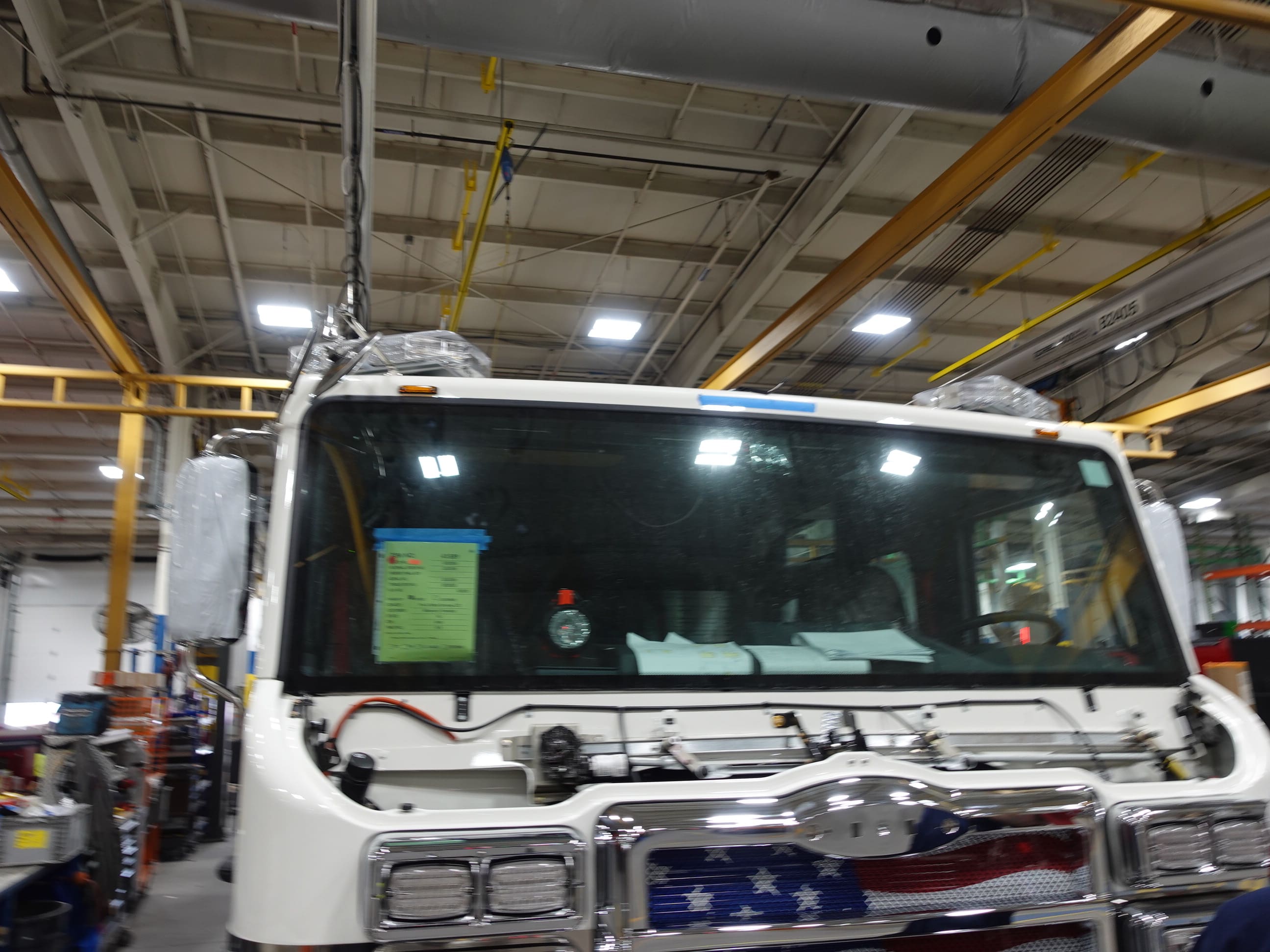

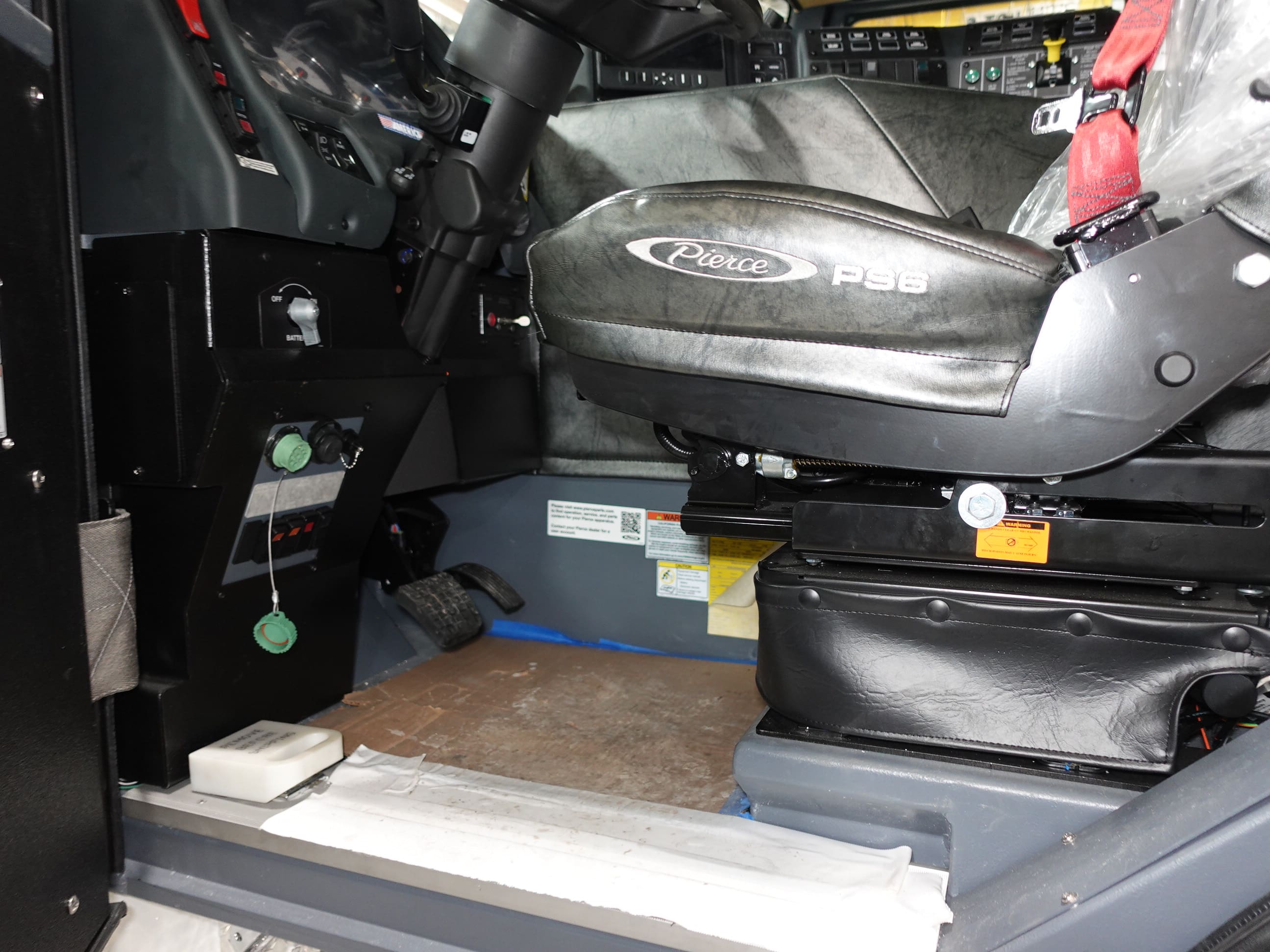

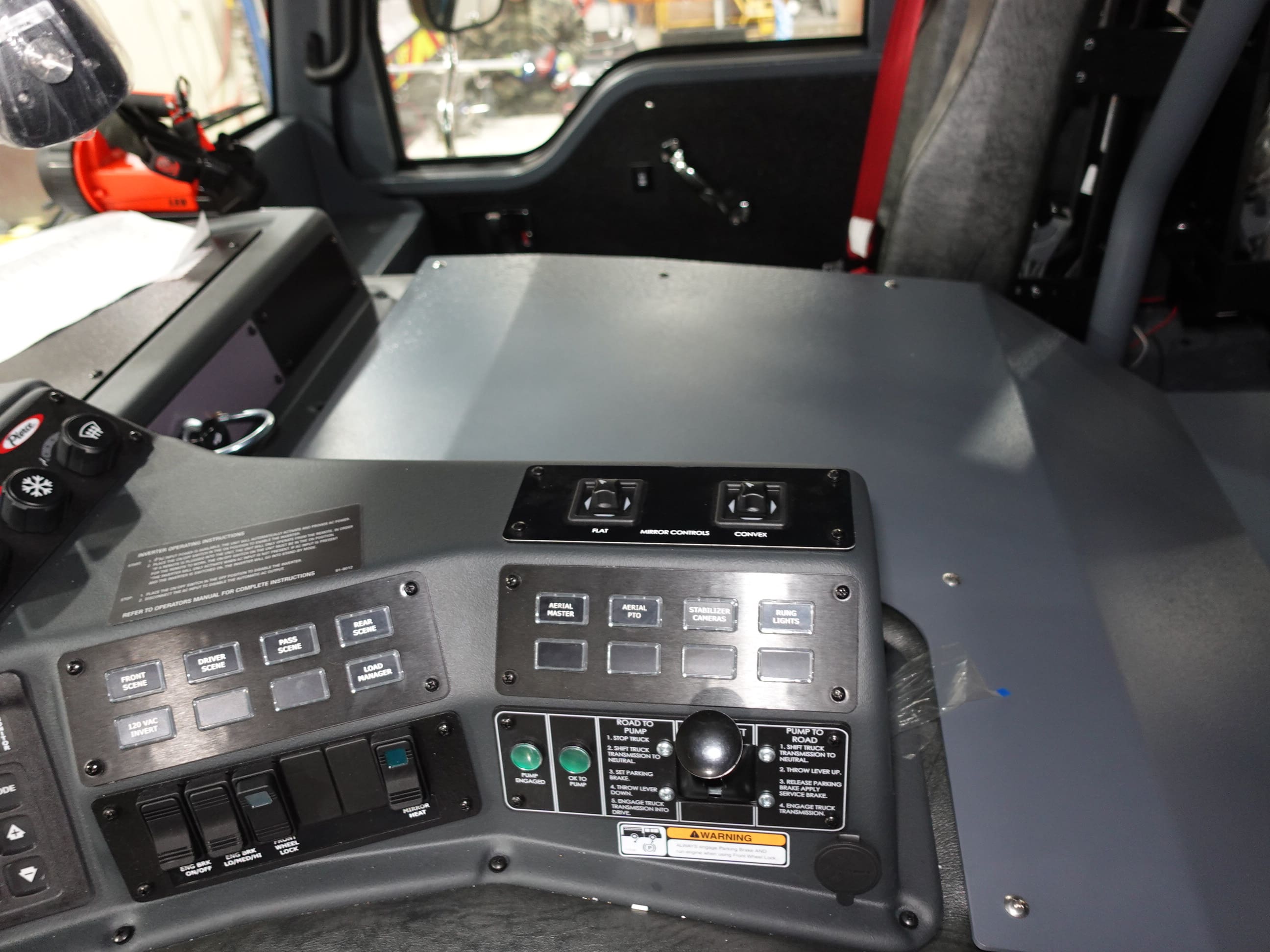

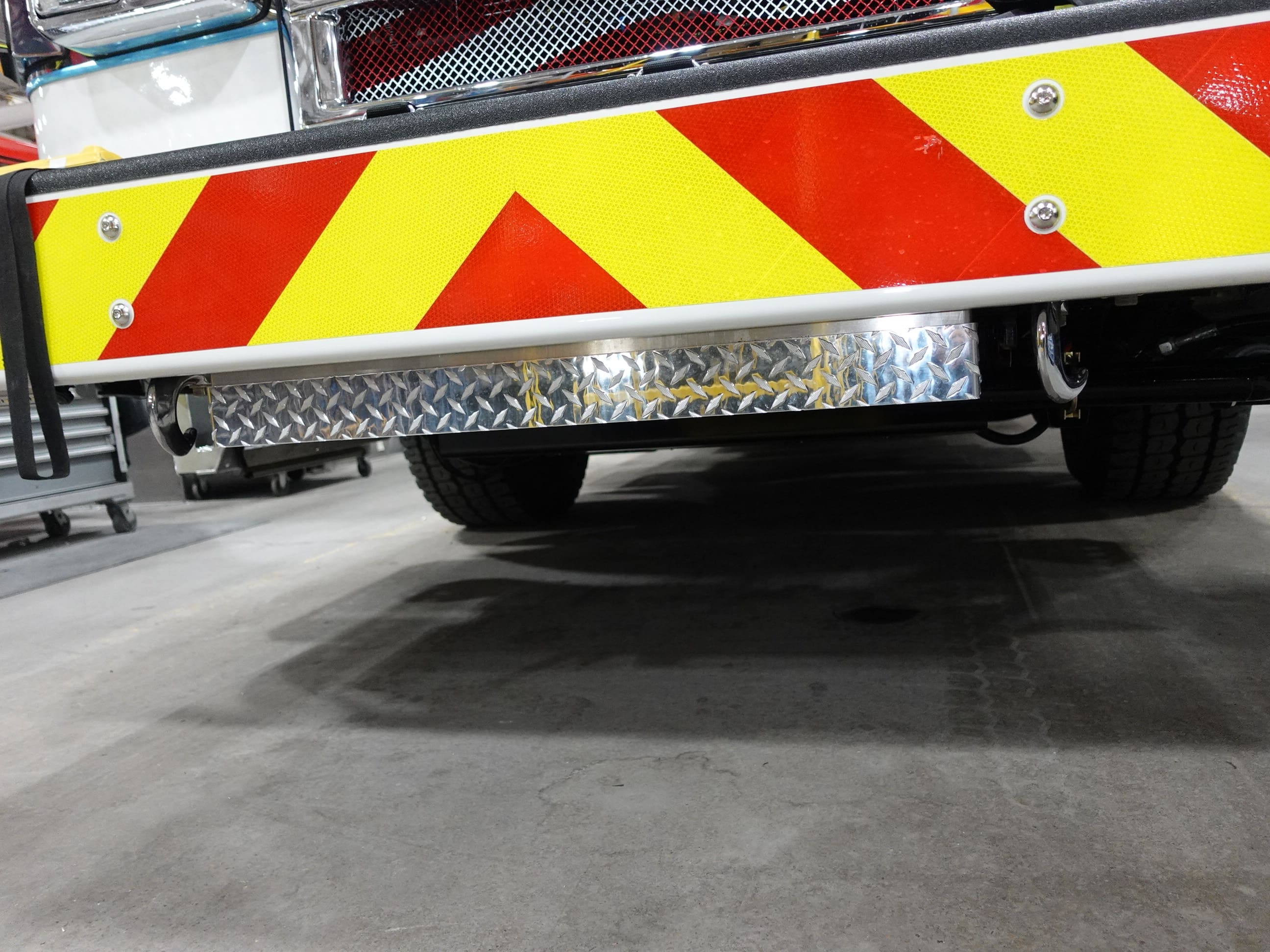

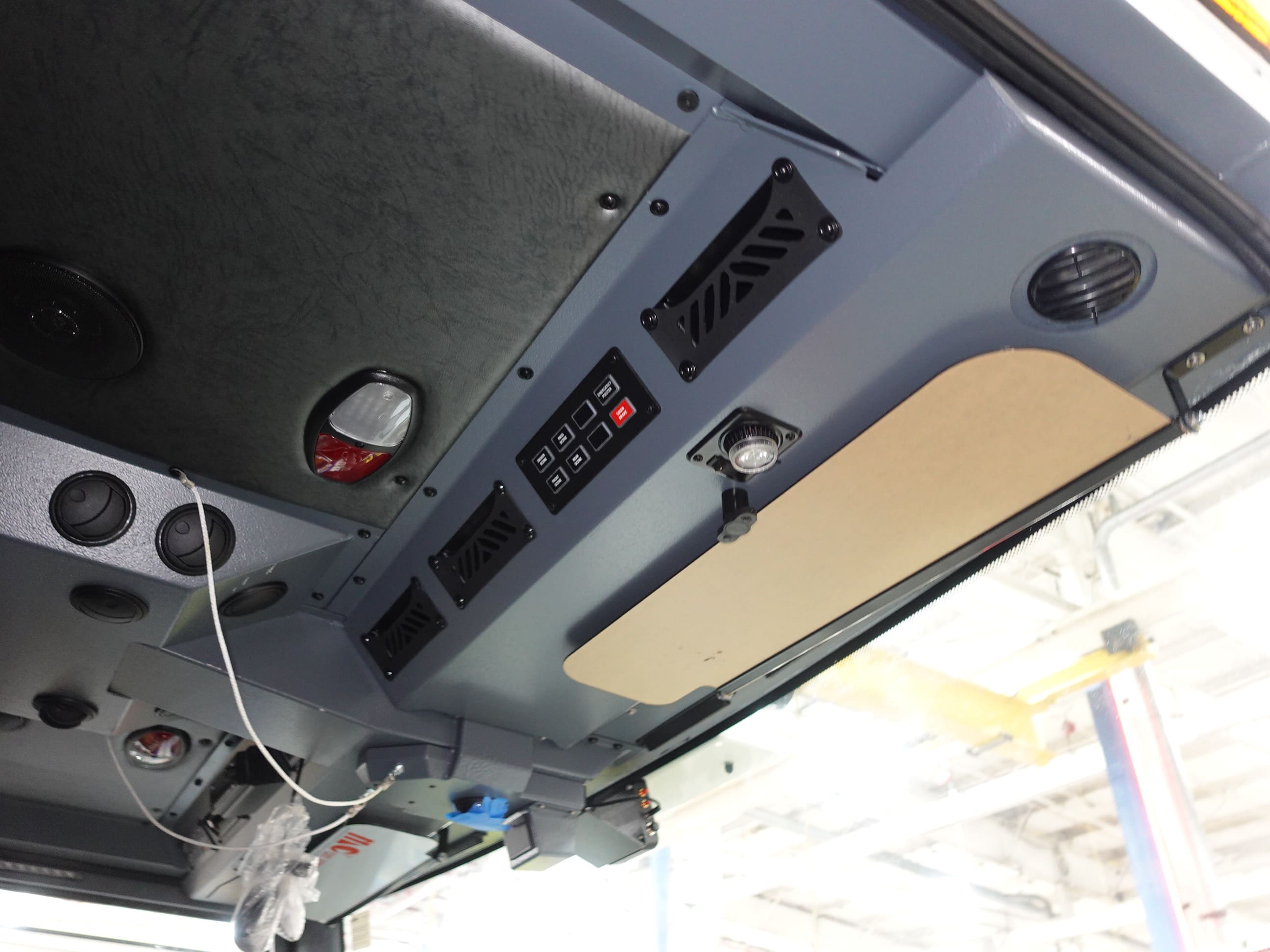

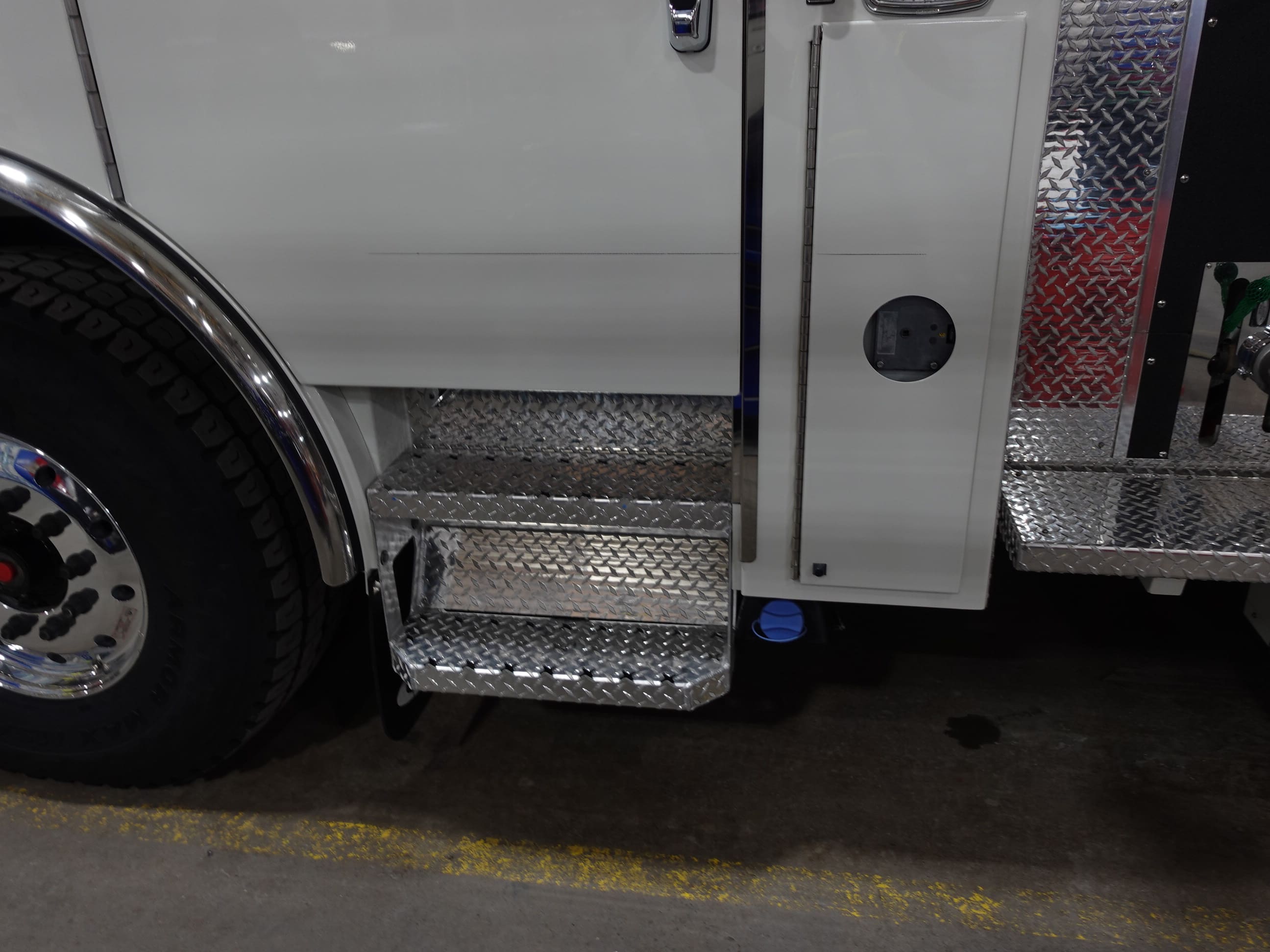

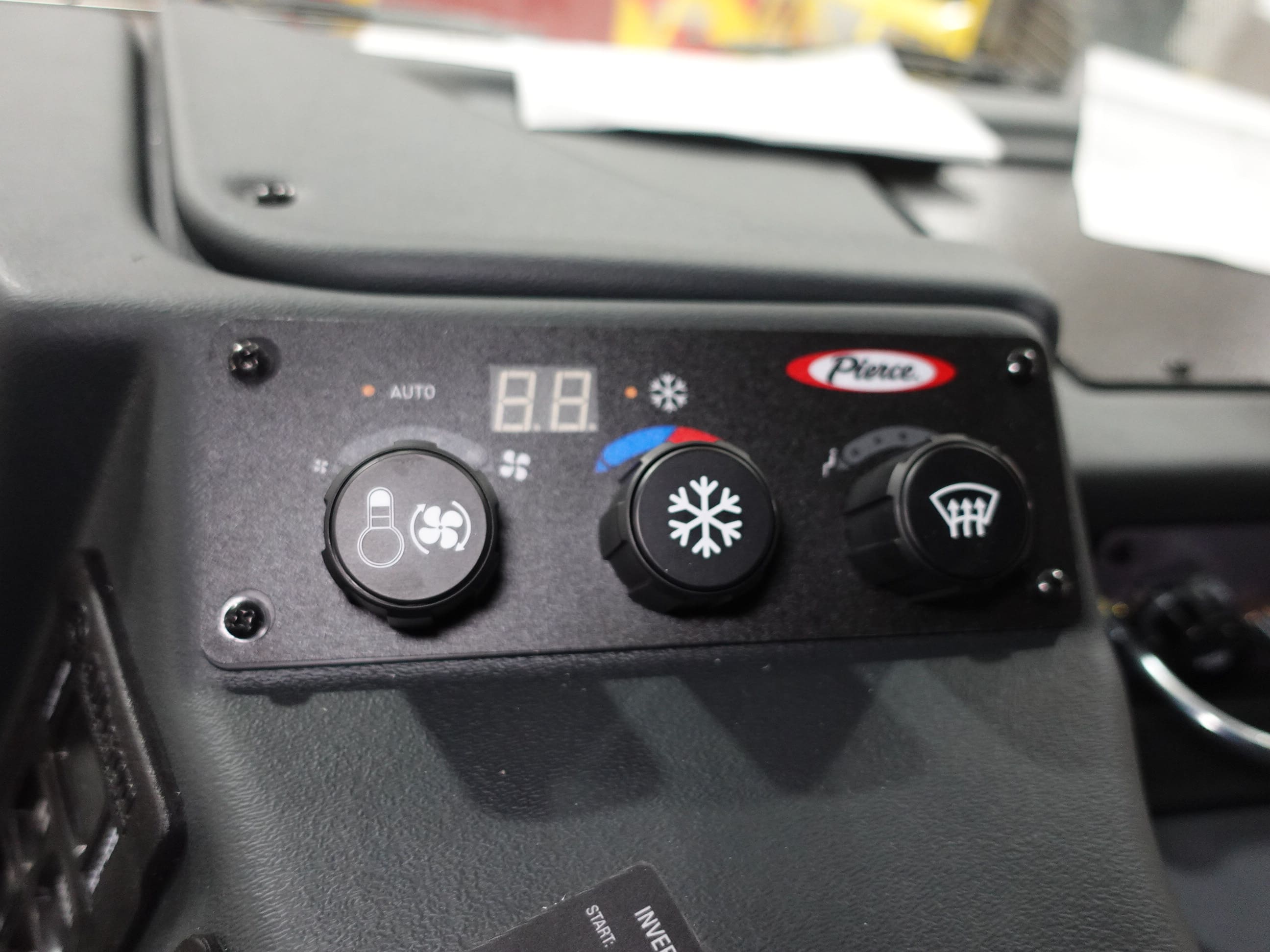

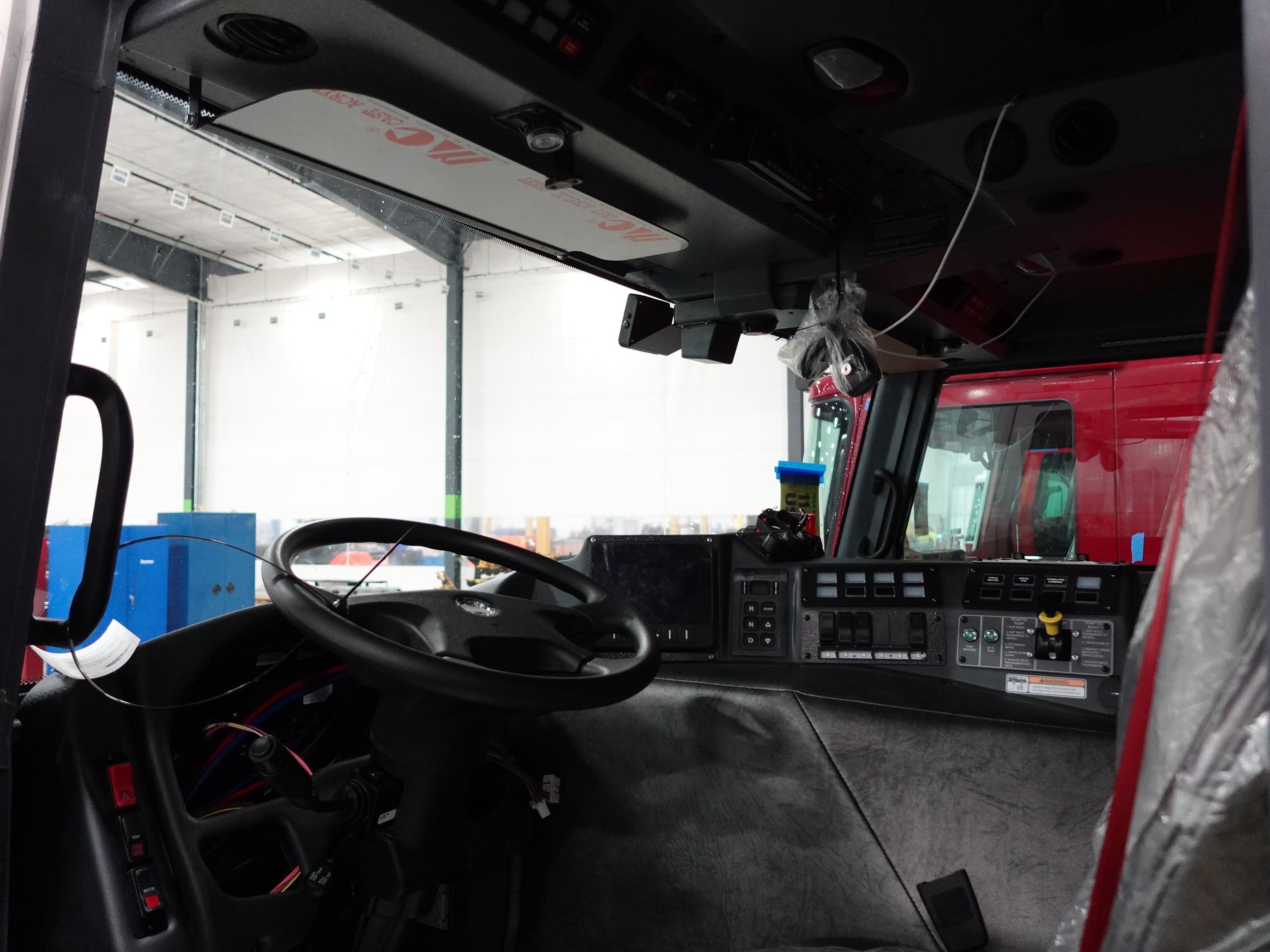

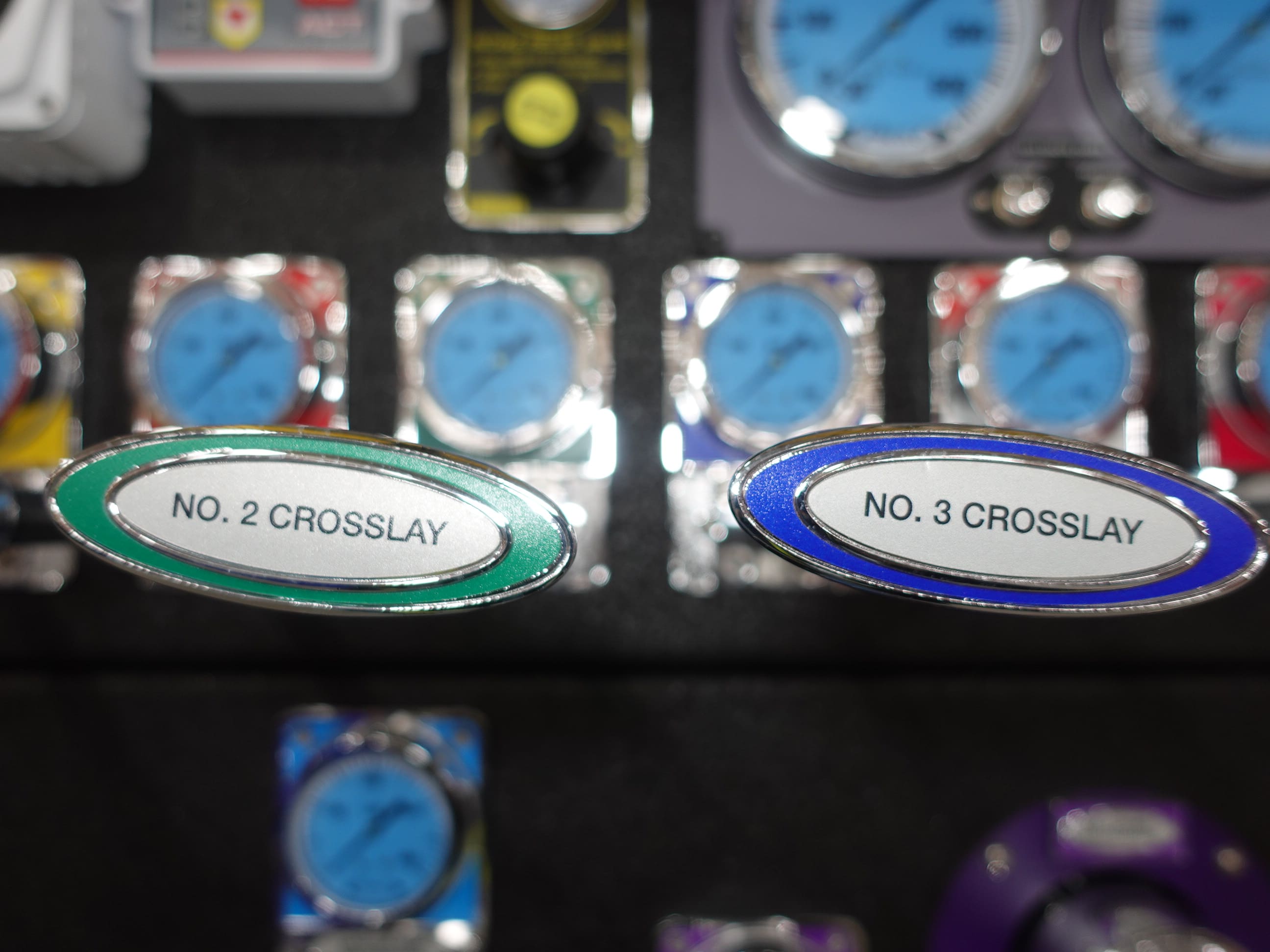

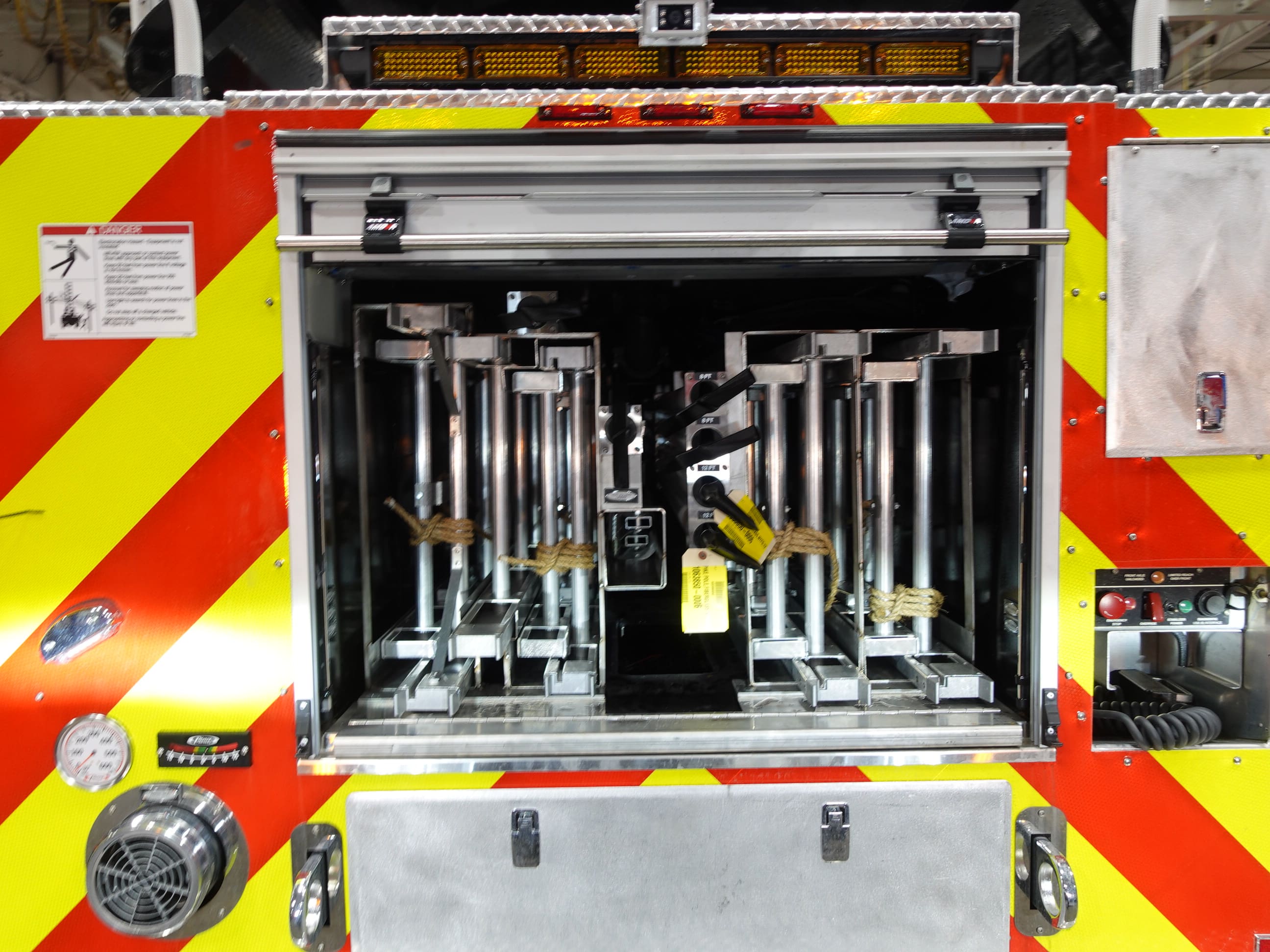

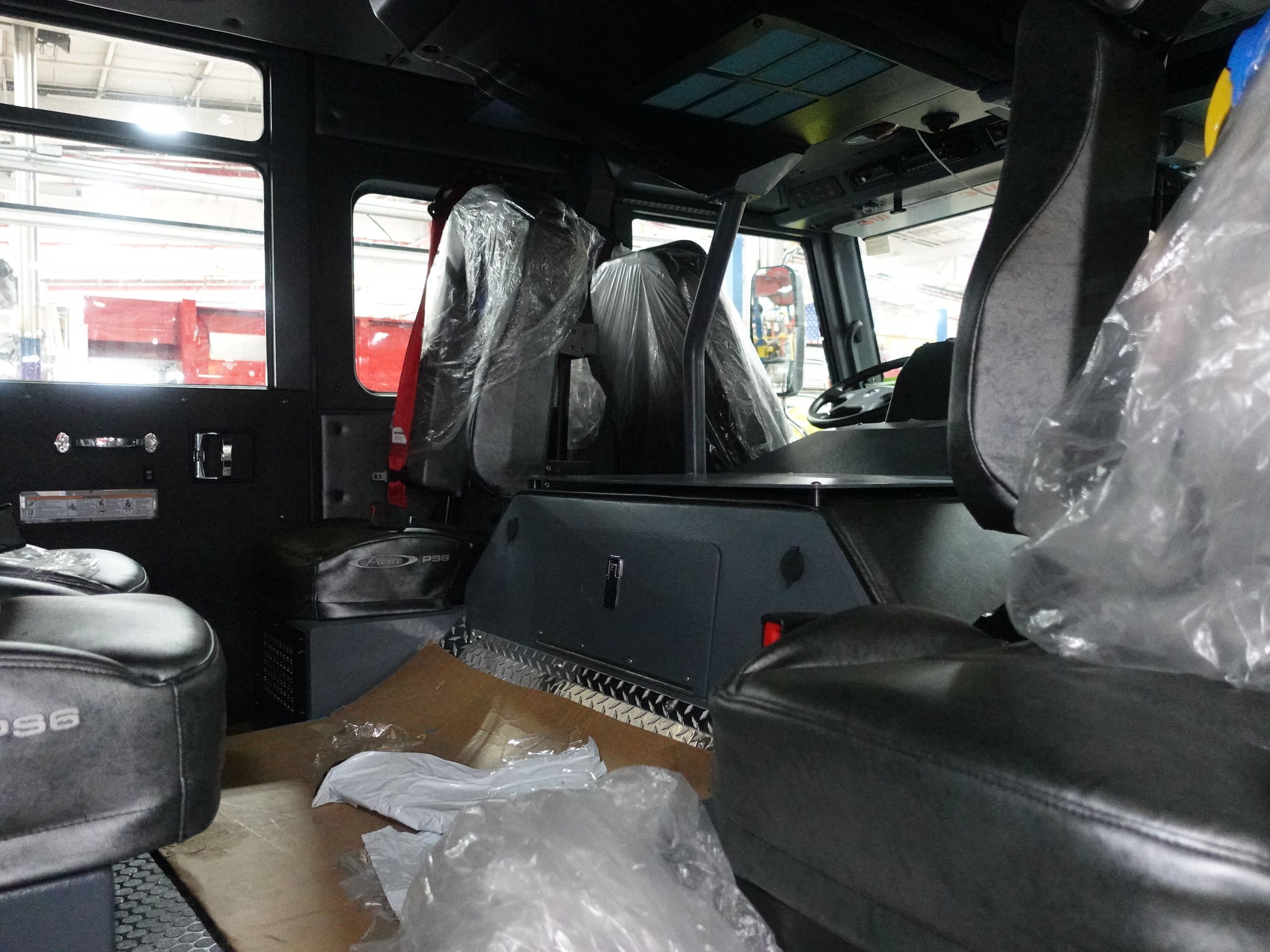

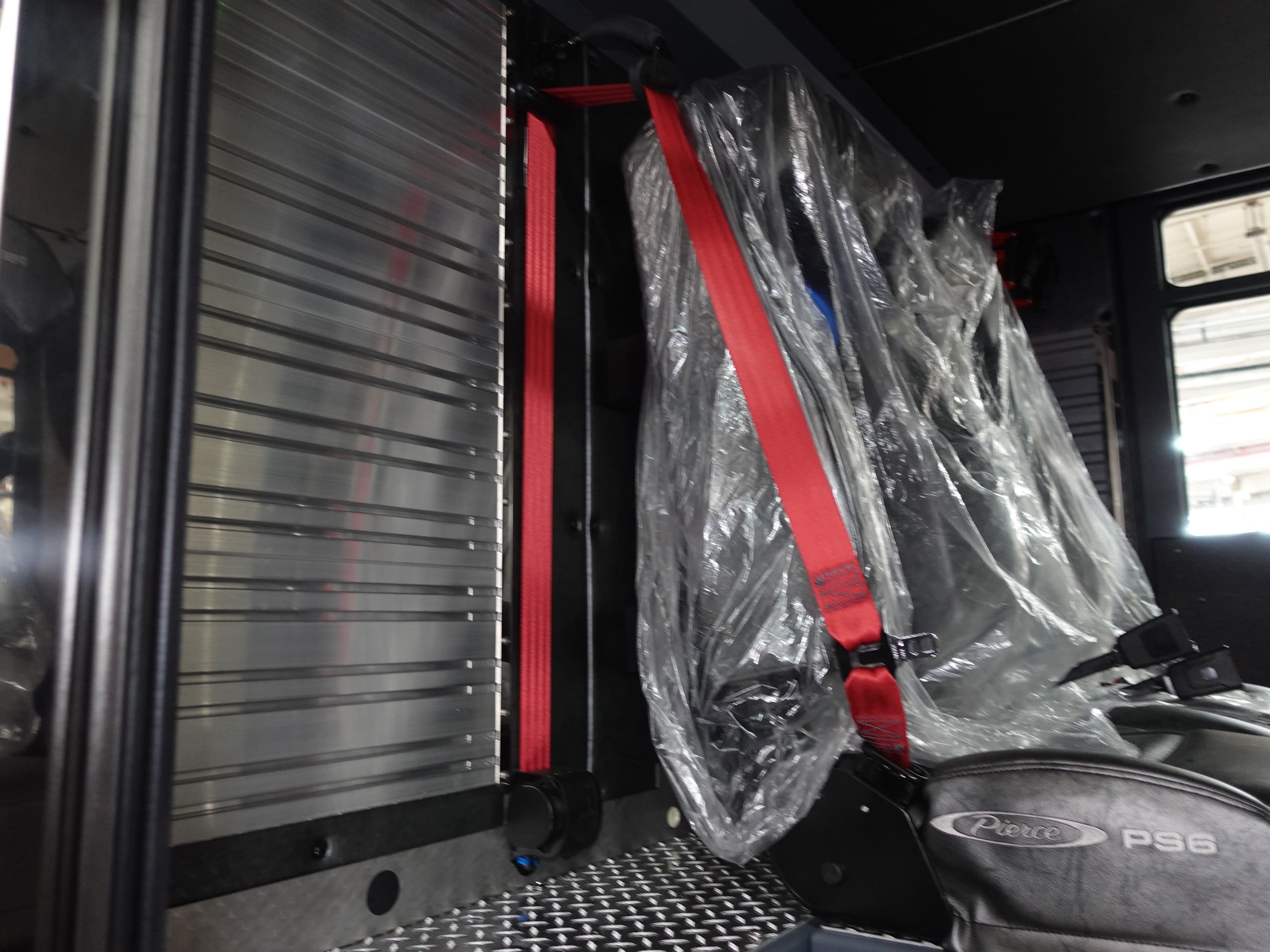

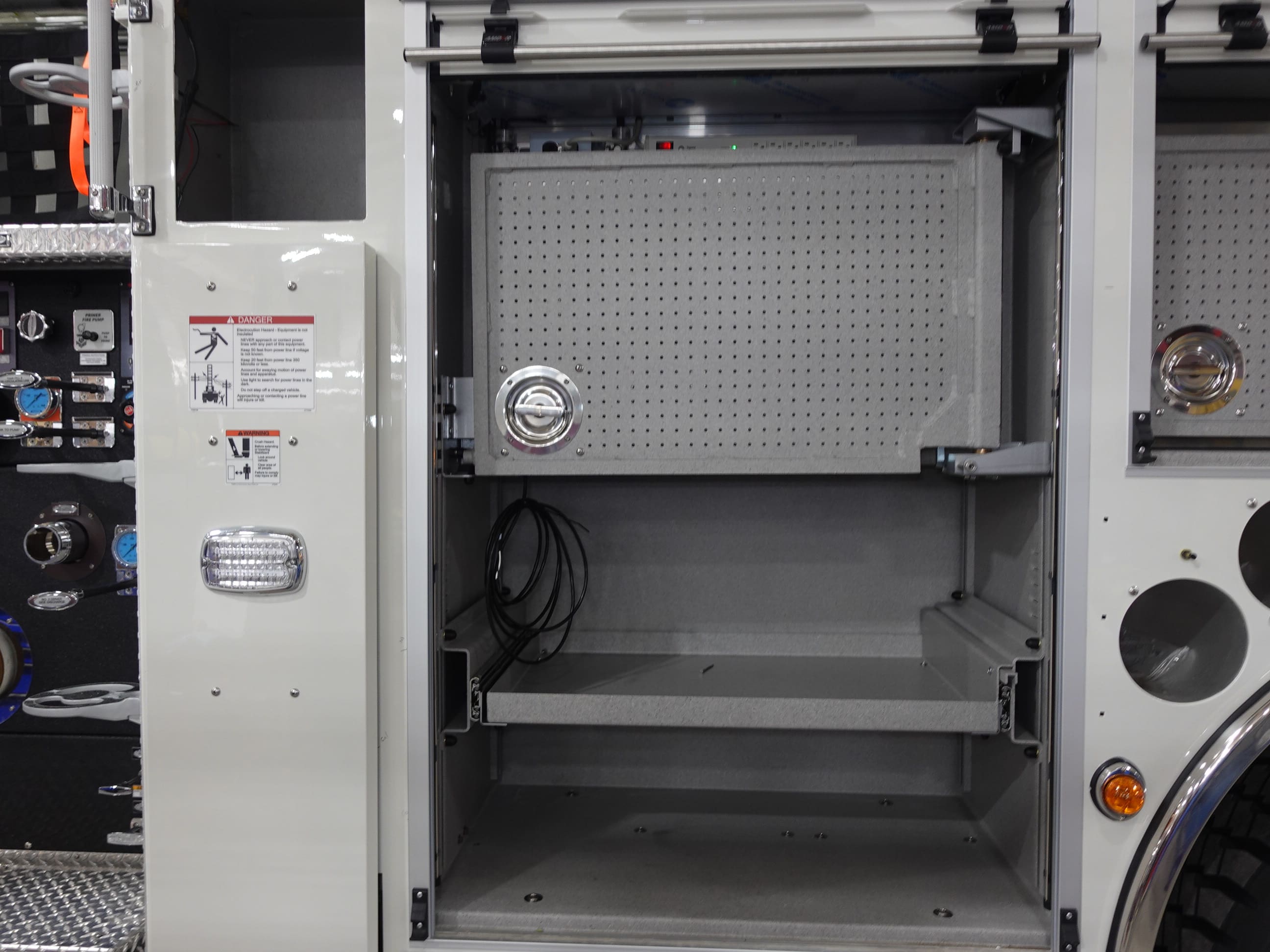

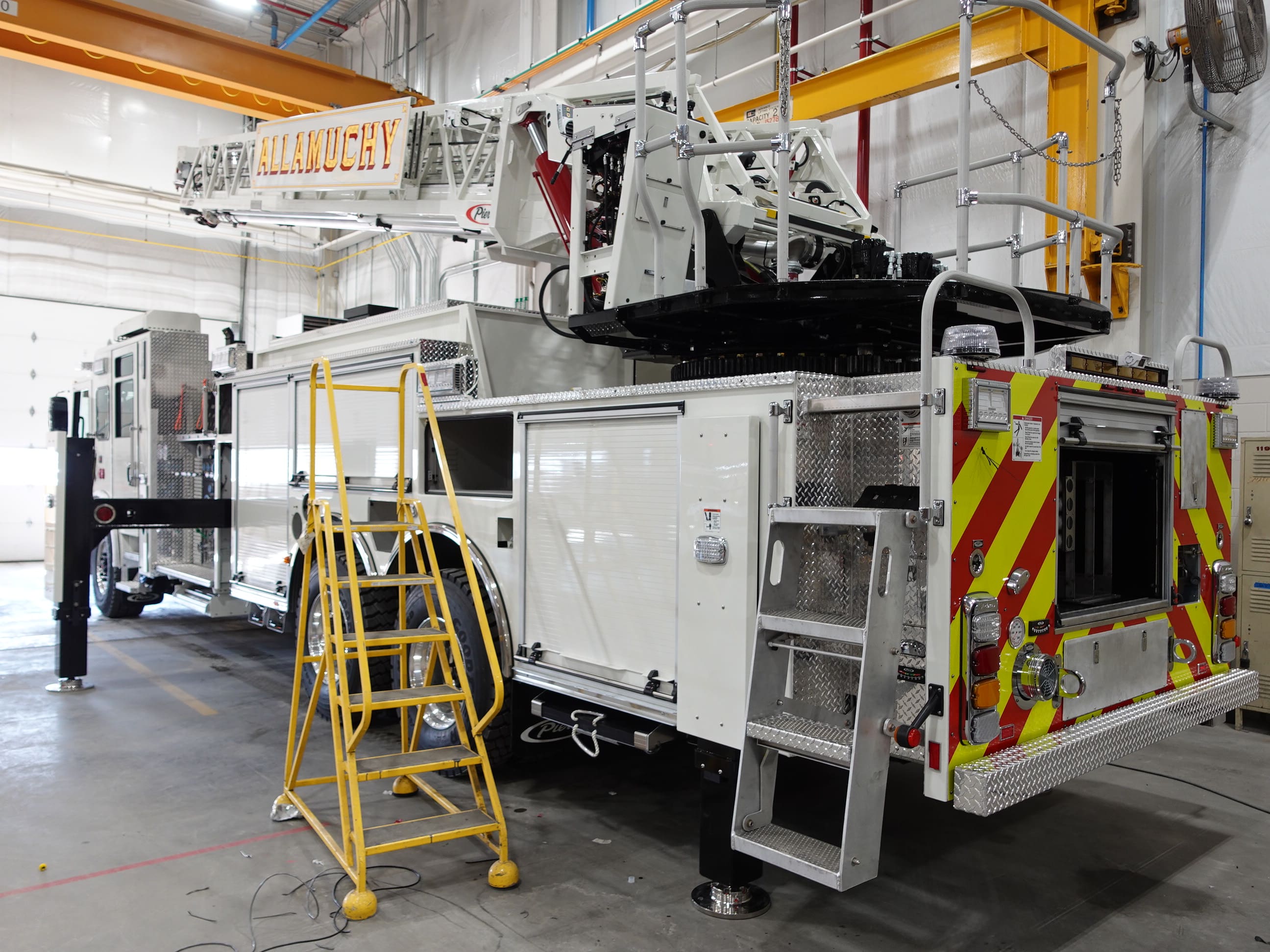

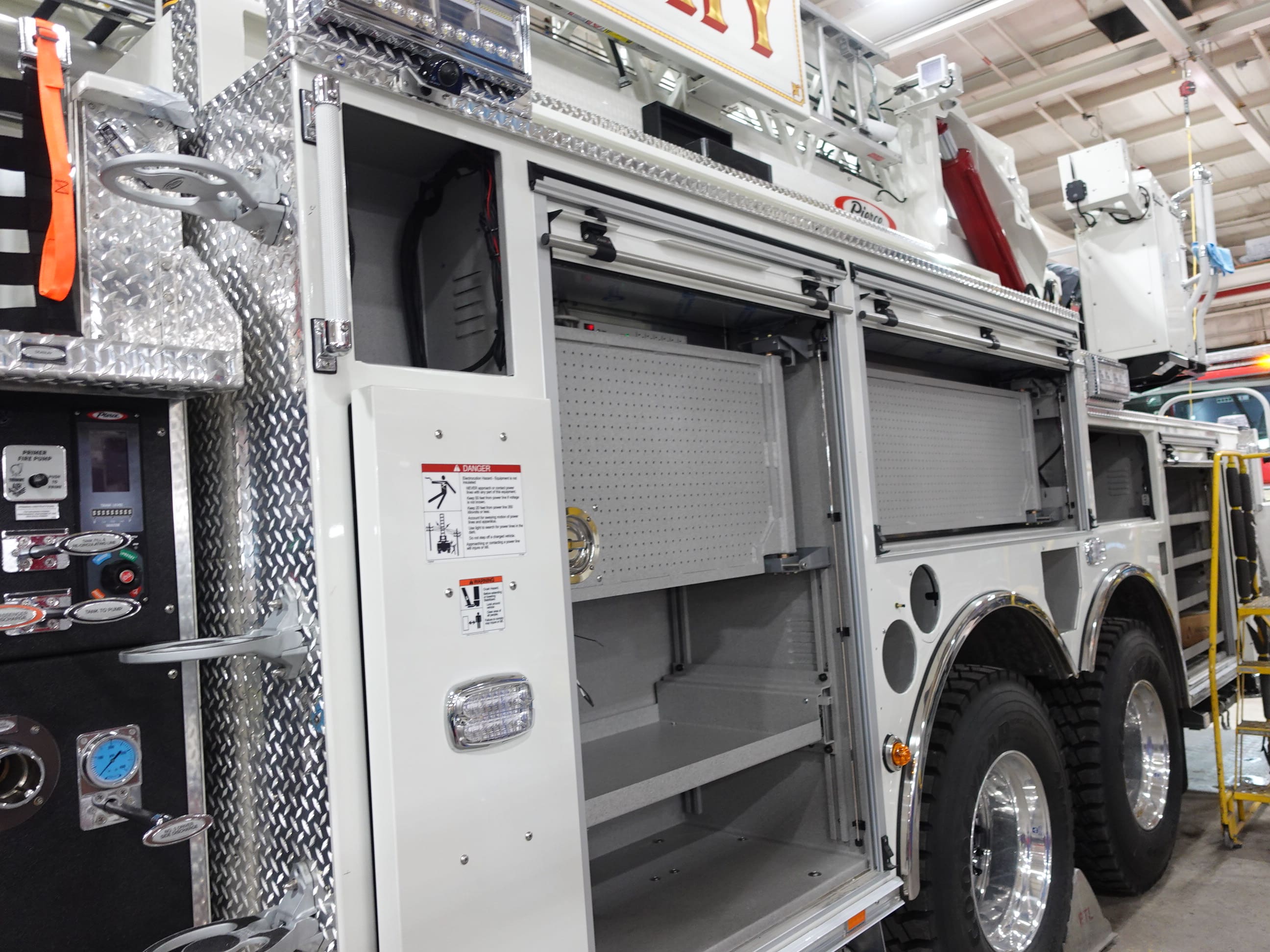

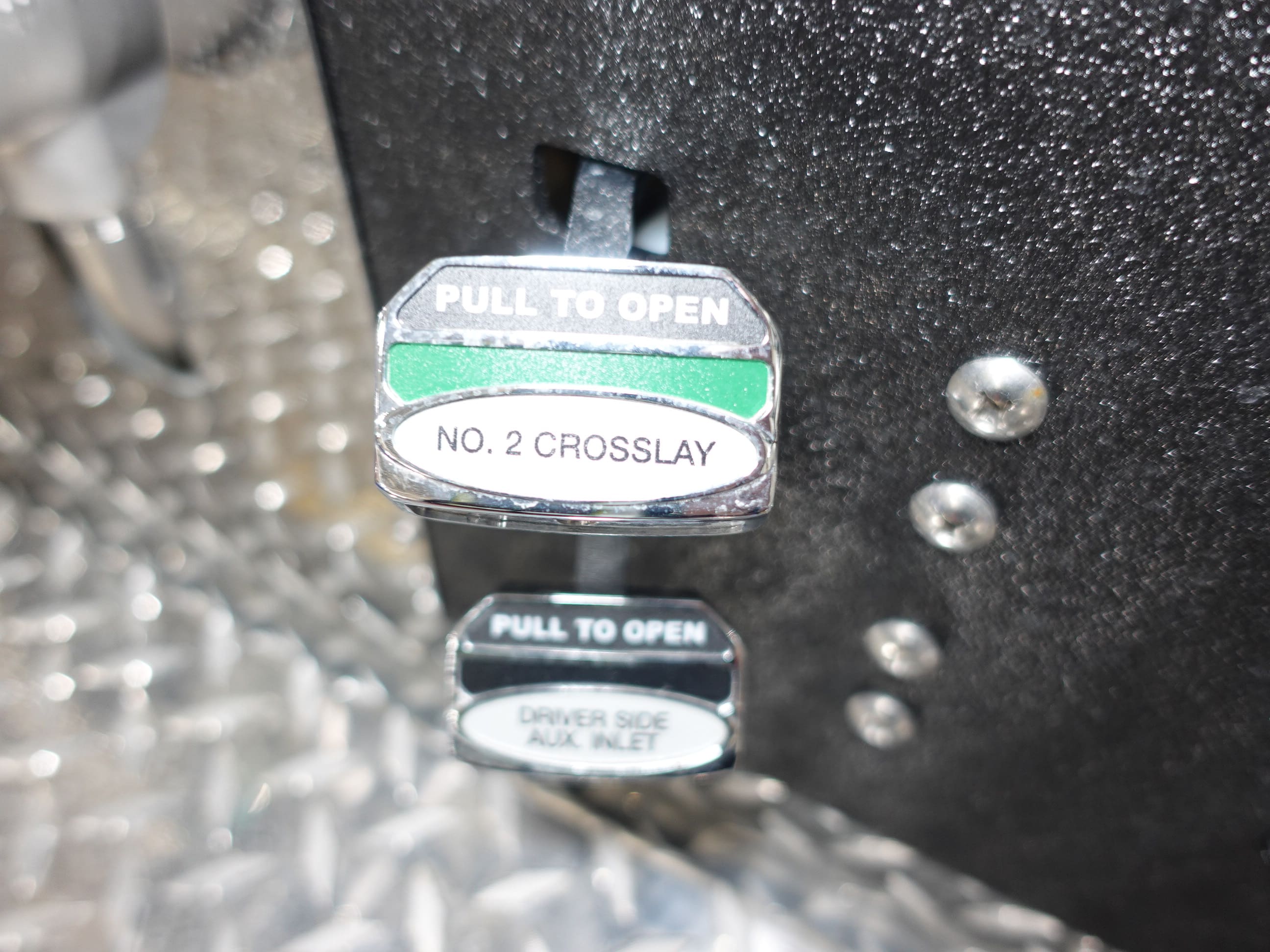

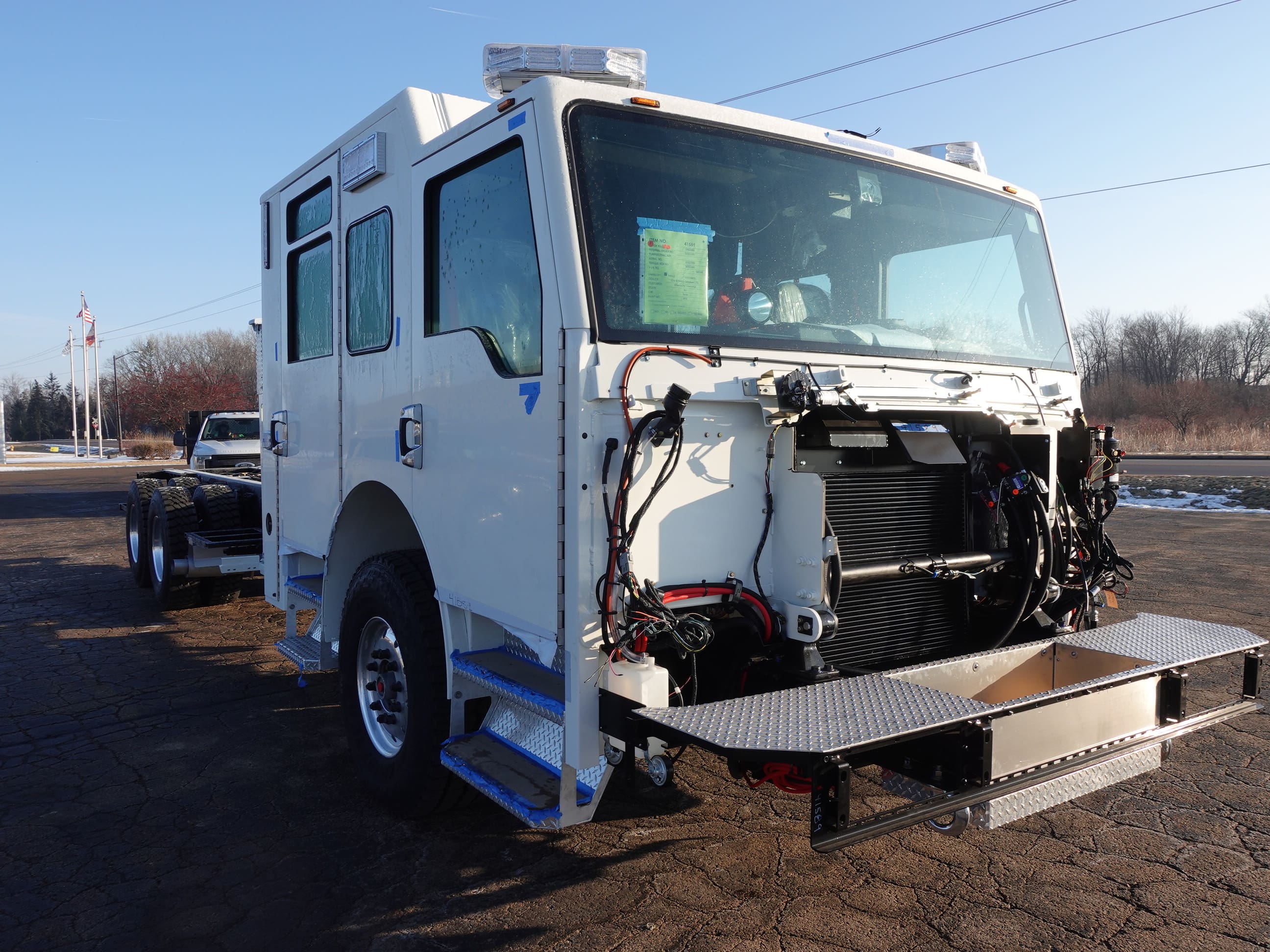

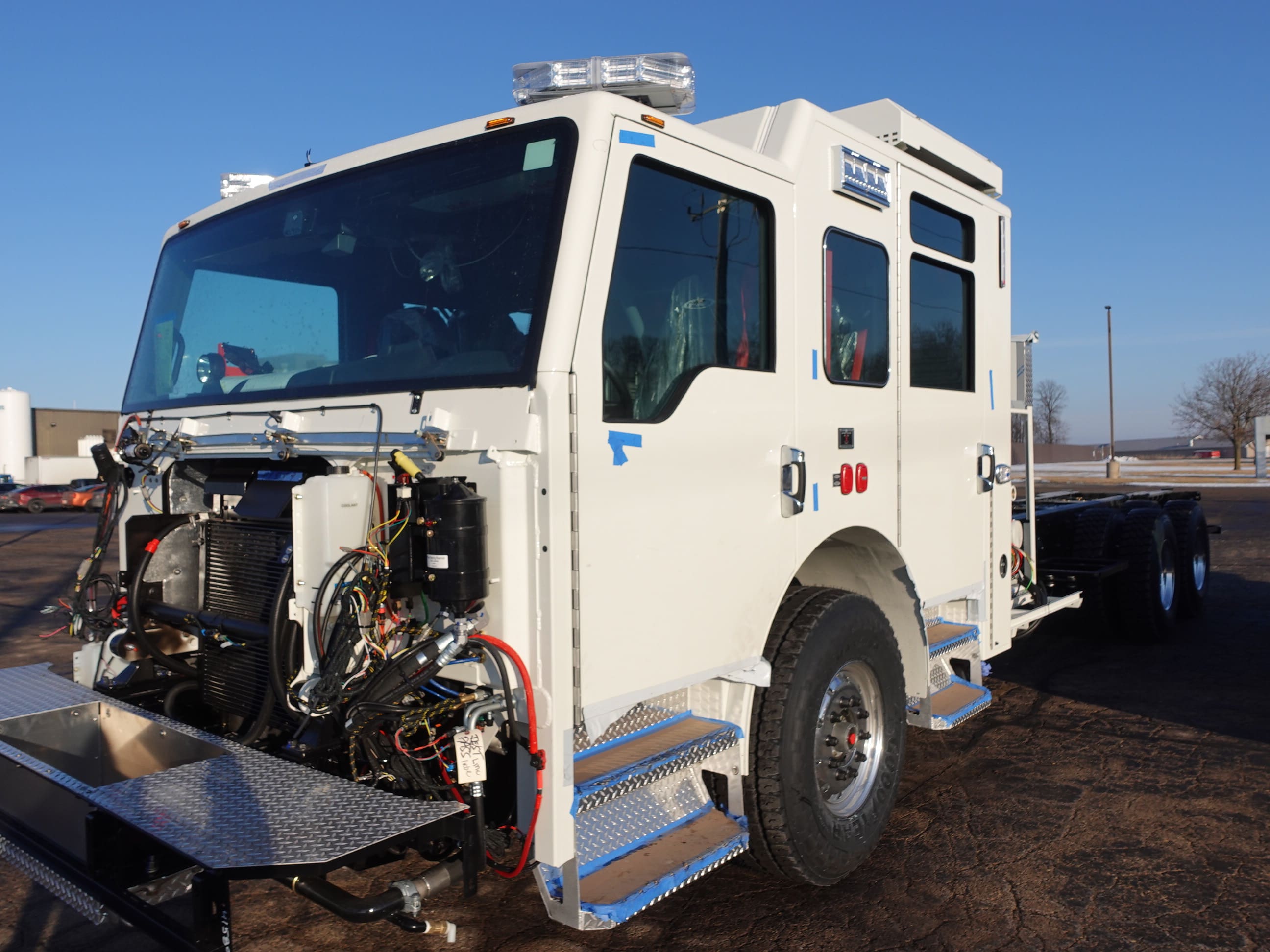

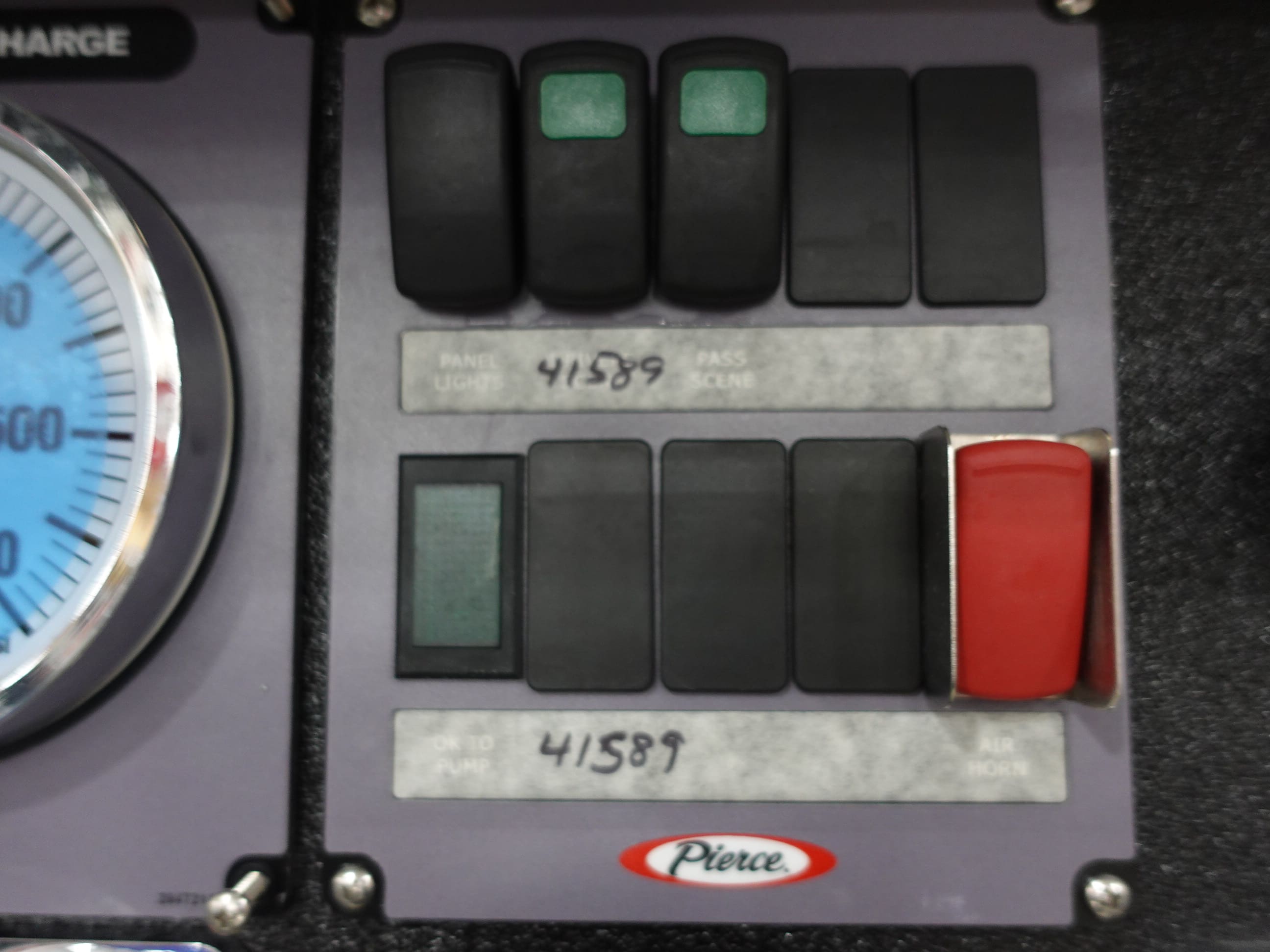

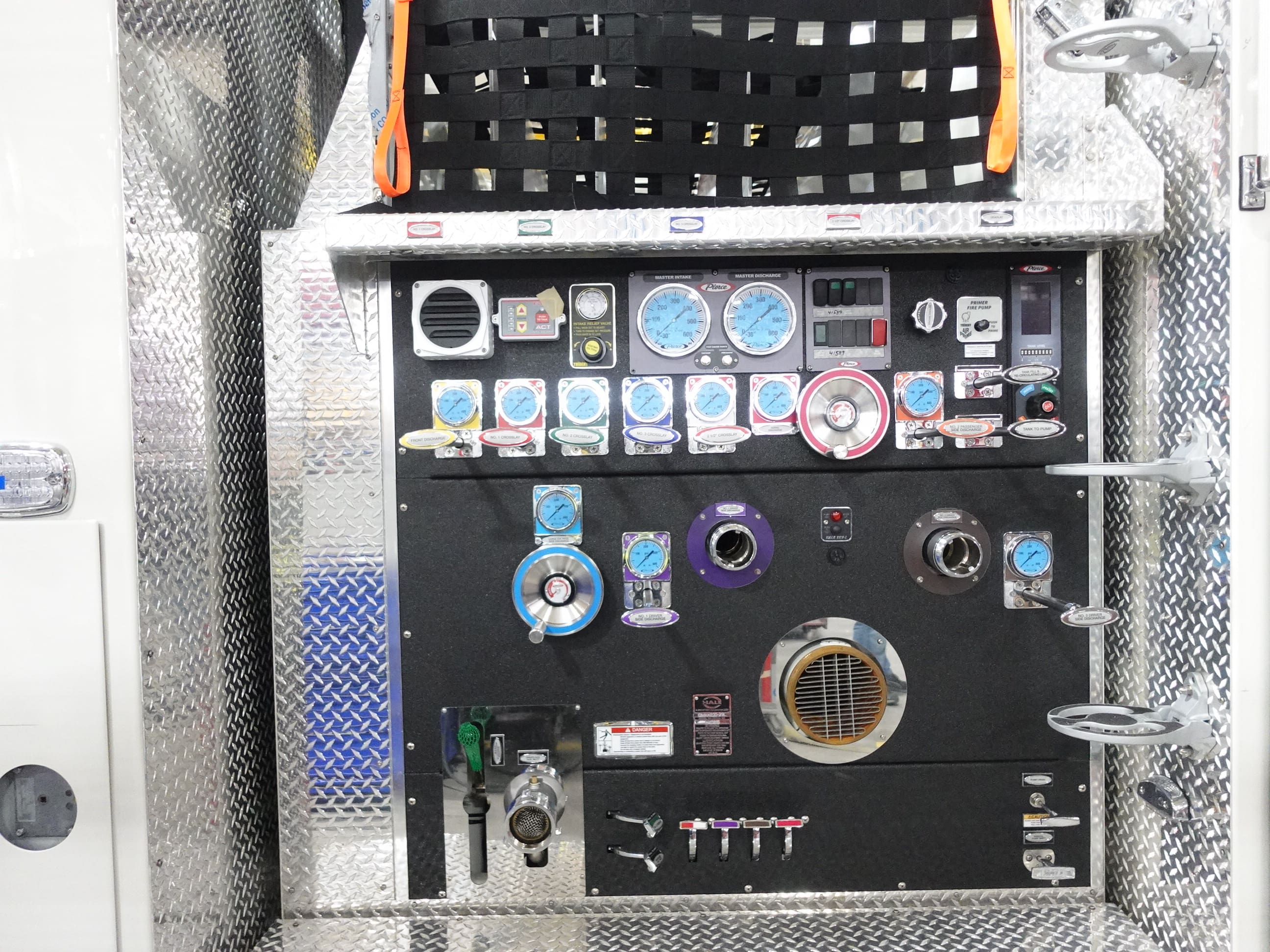

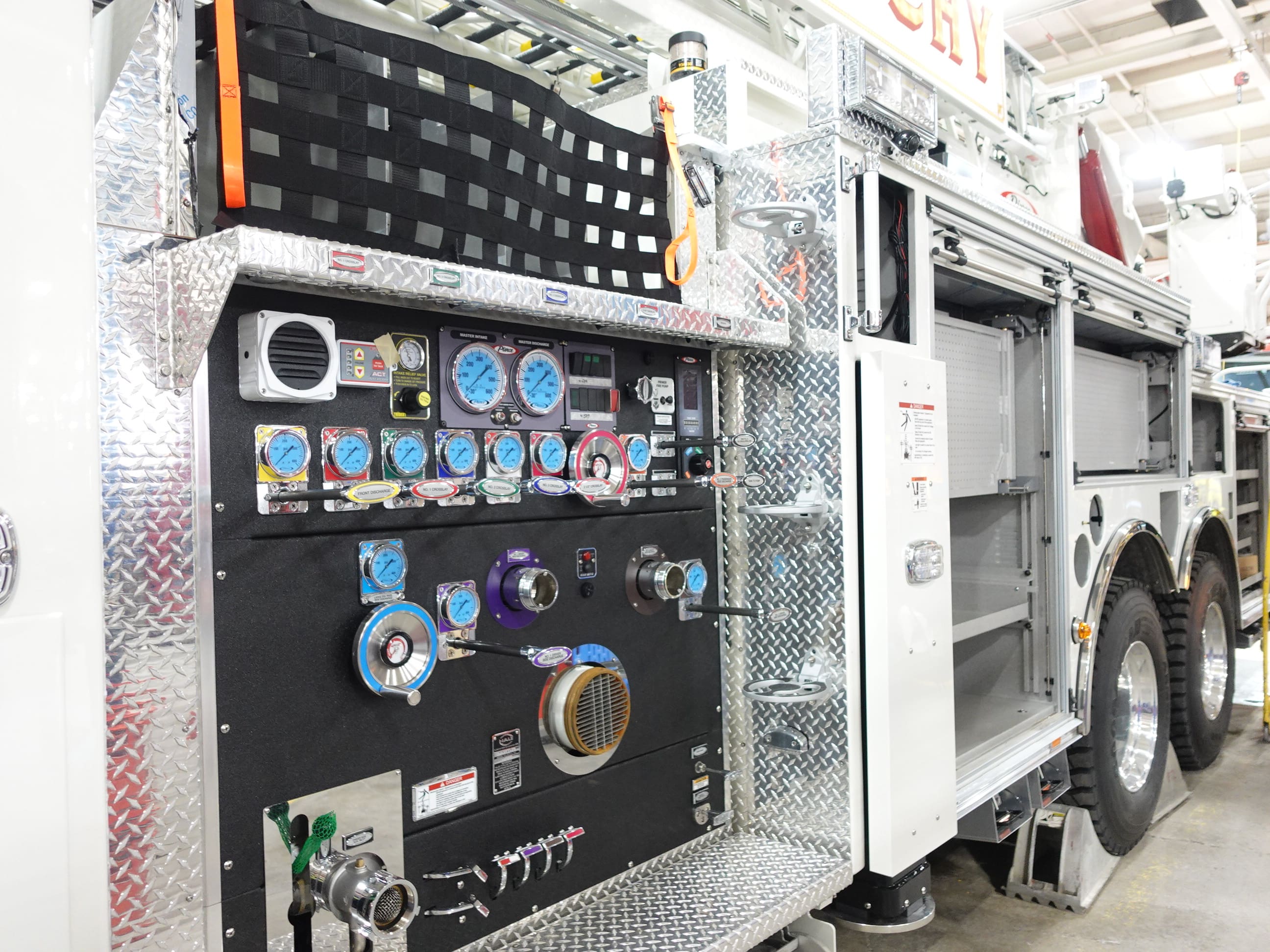

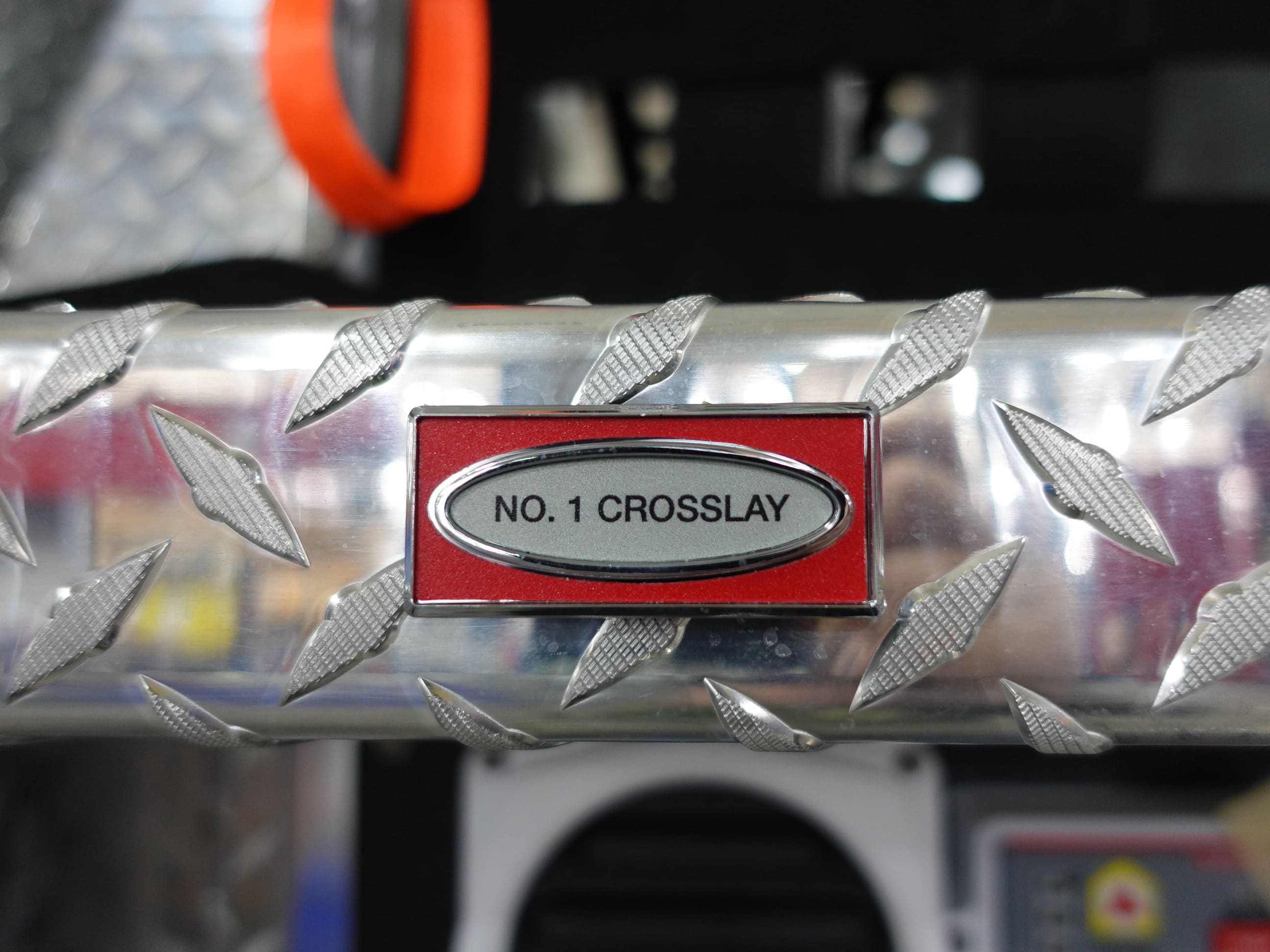

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance
inspection. This is the last scheduled report.
03-06-26

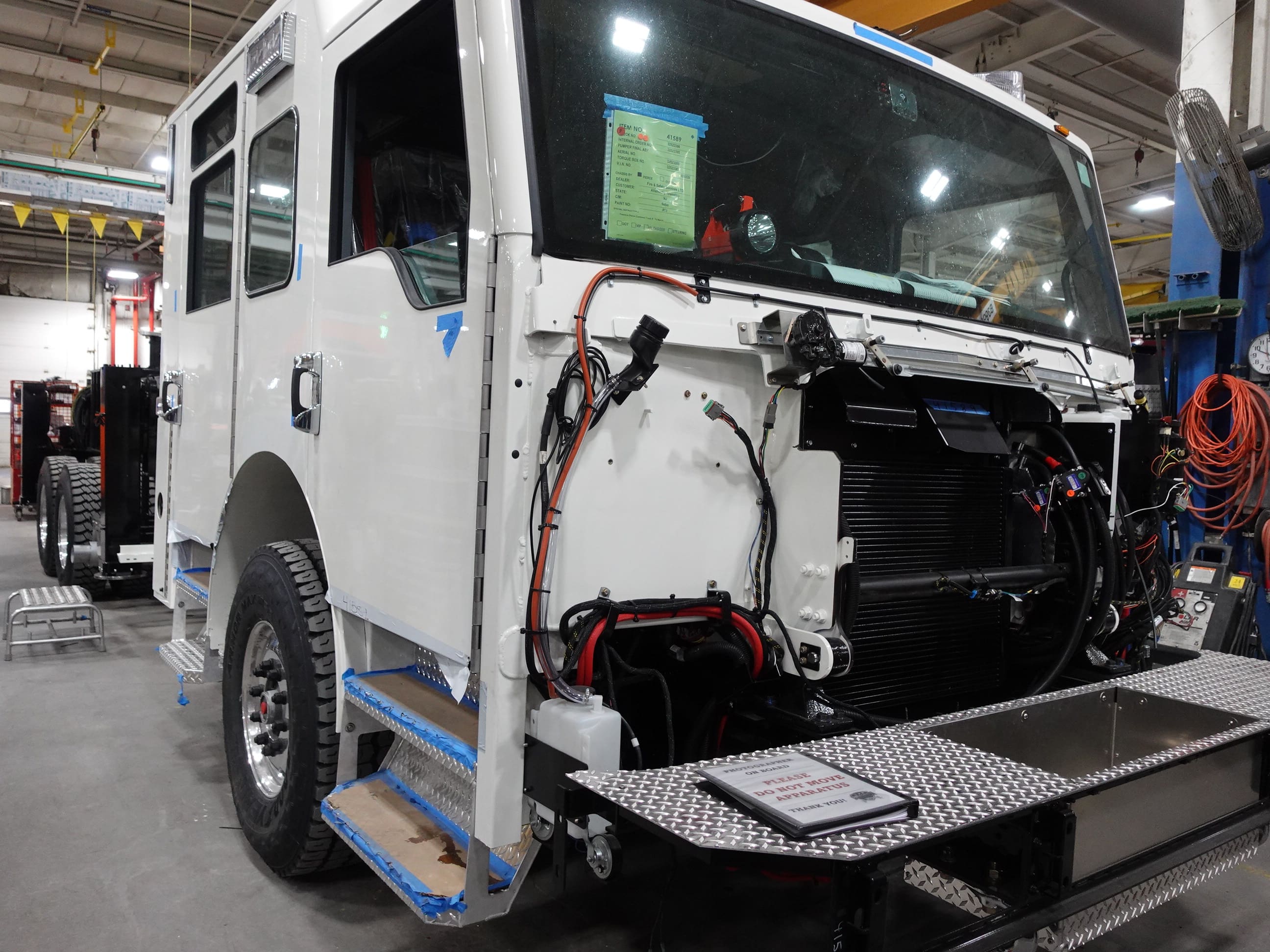

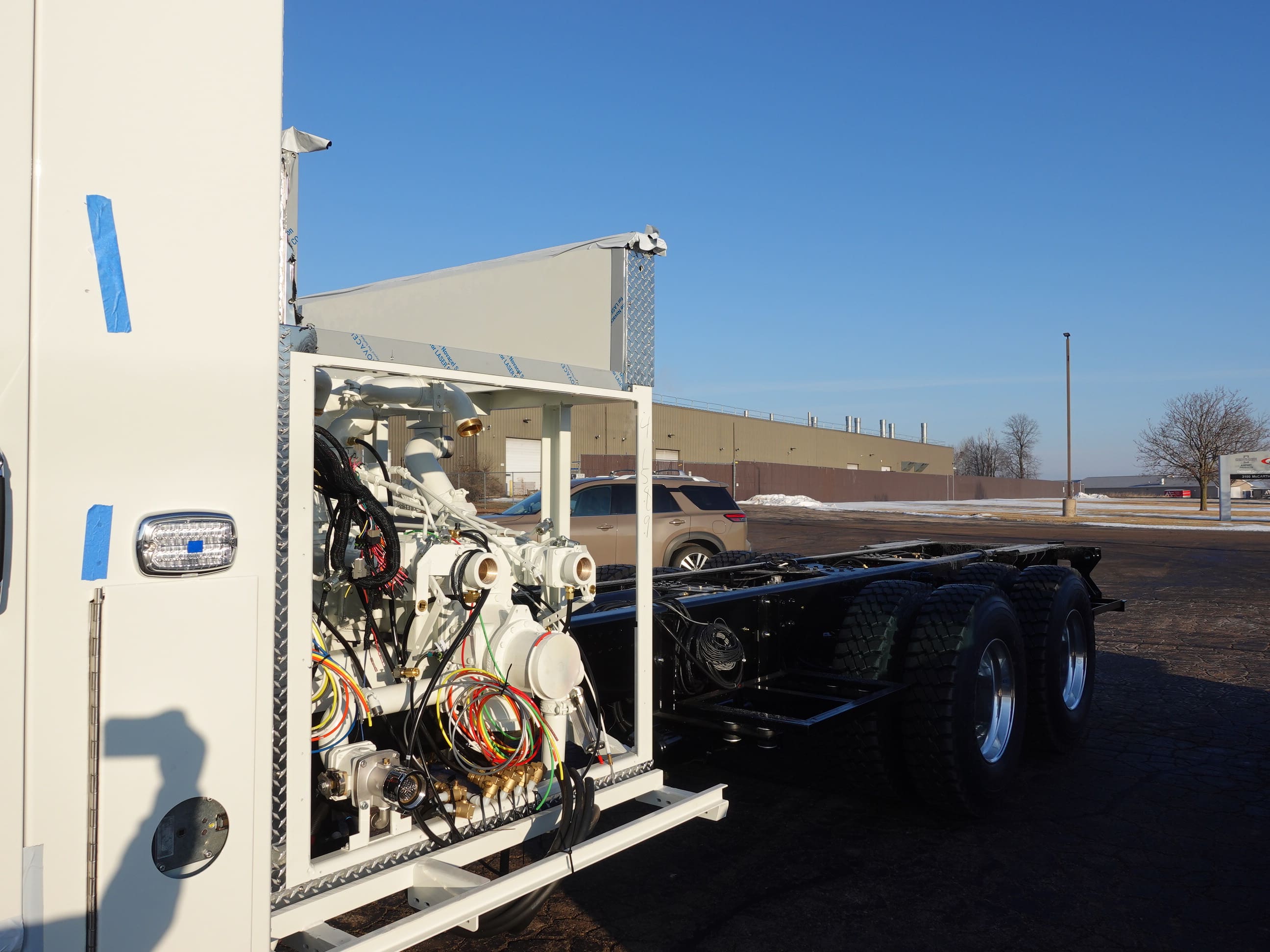

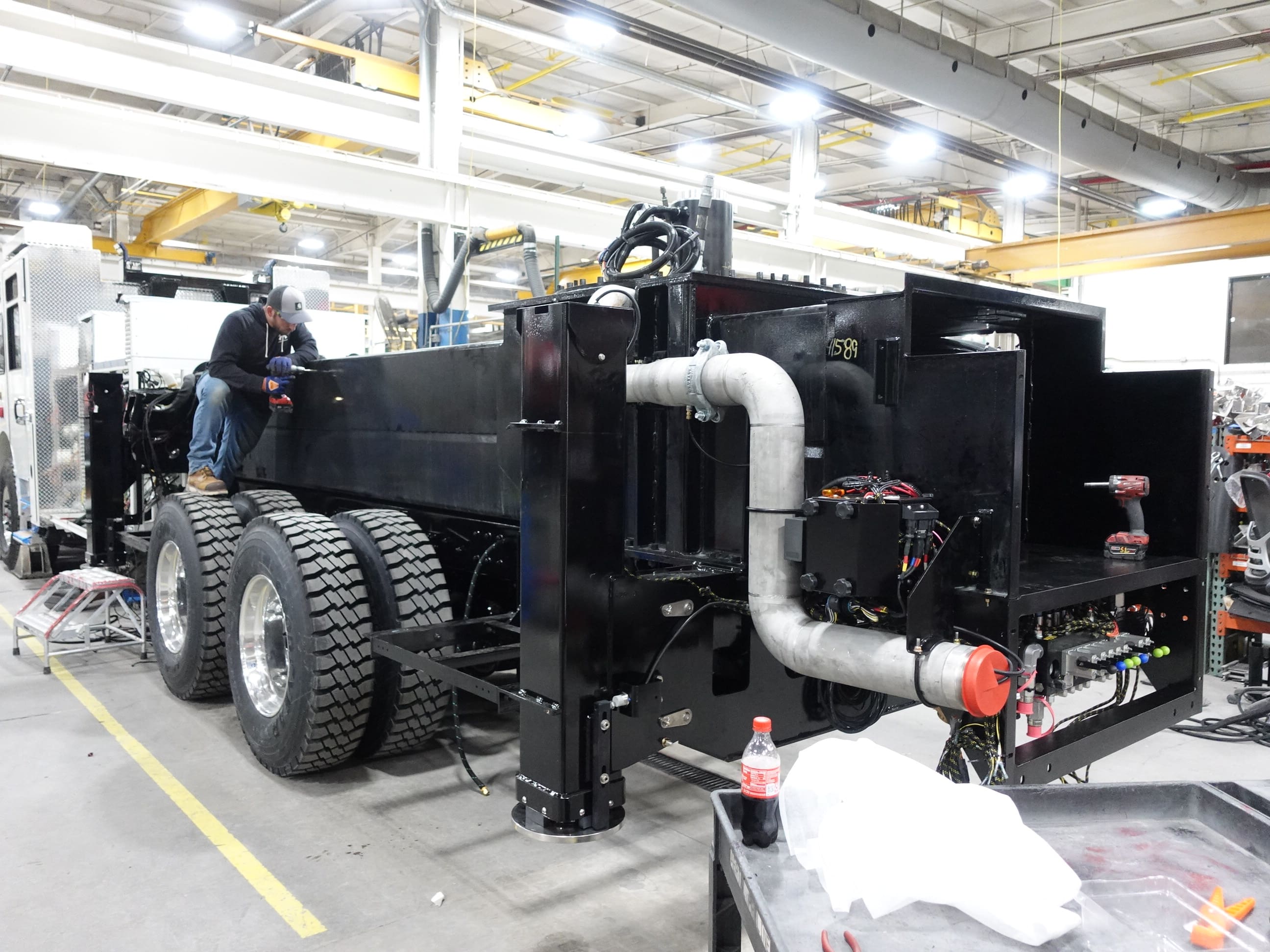

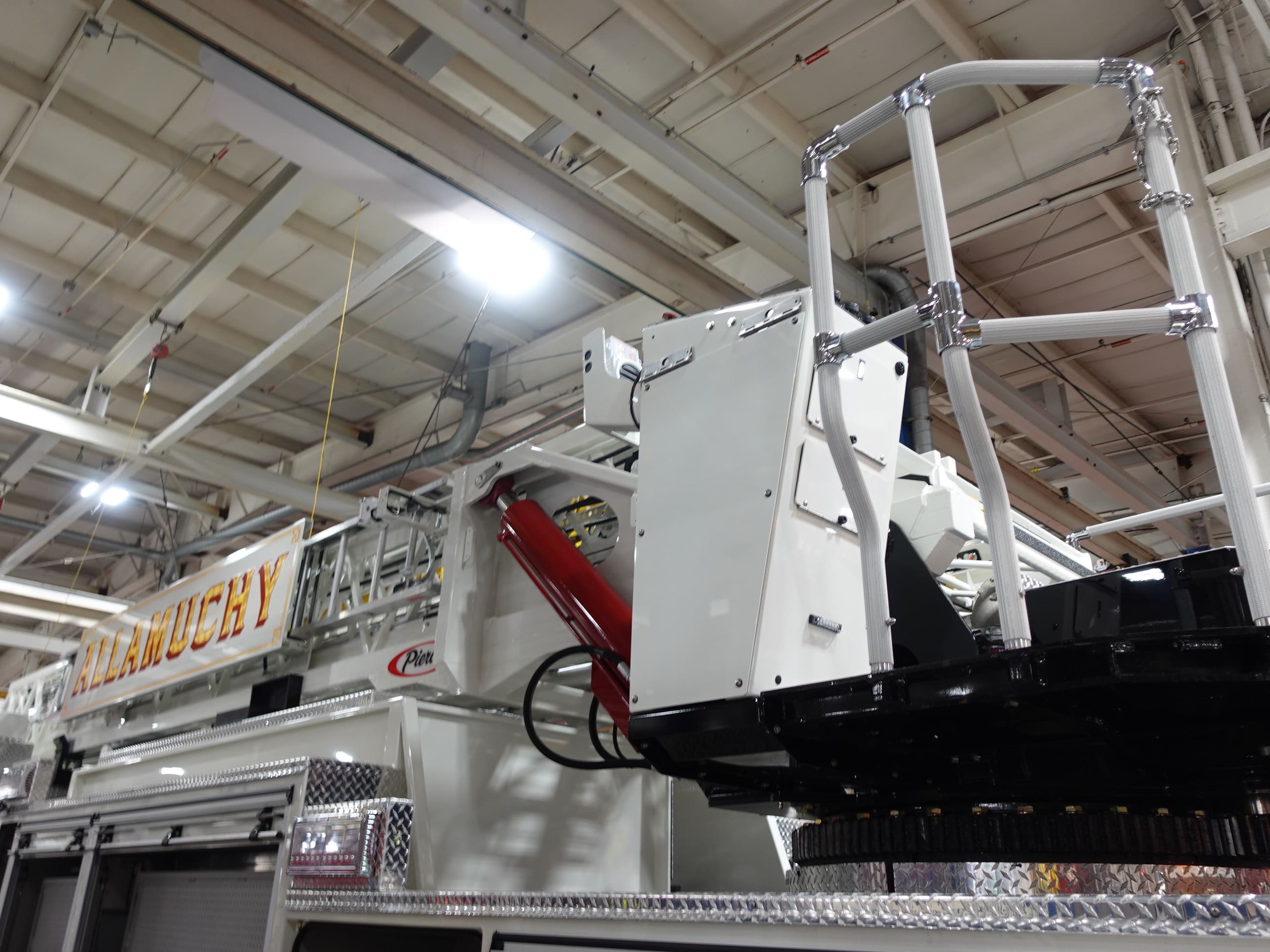

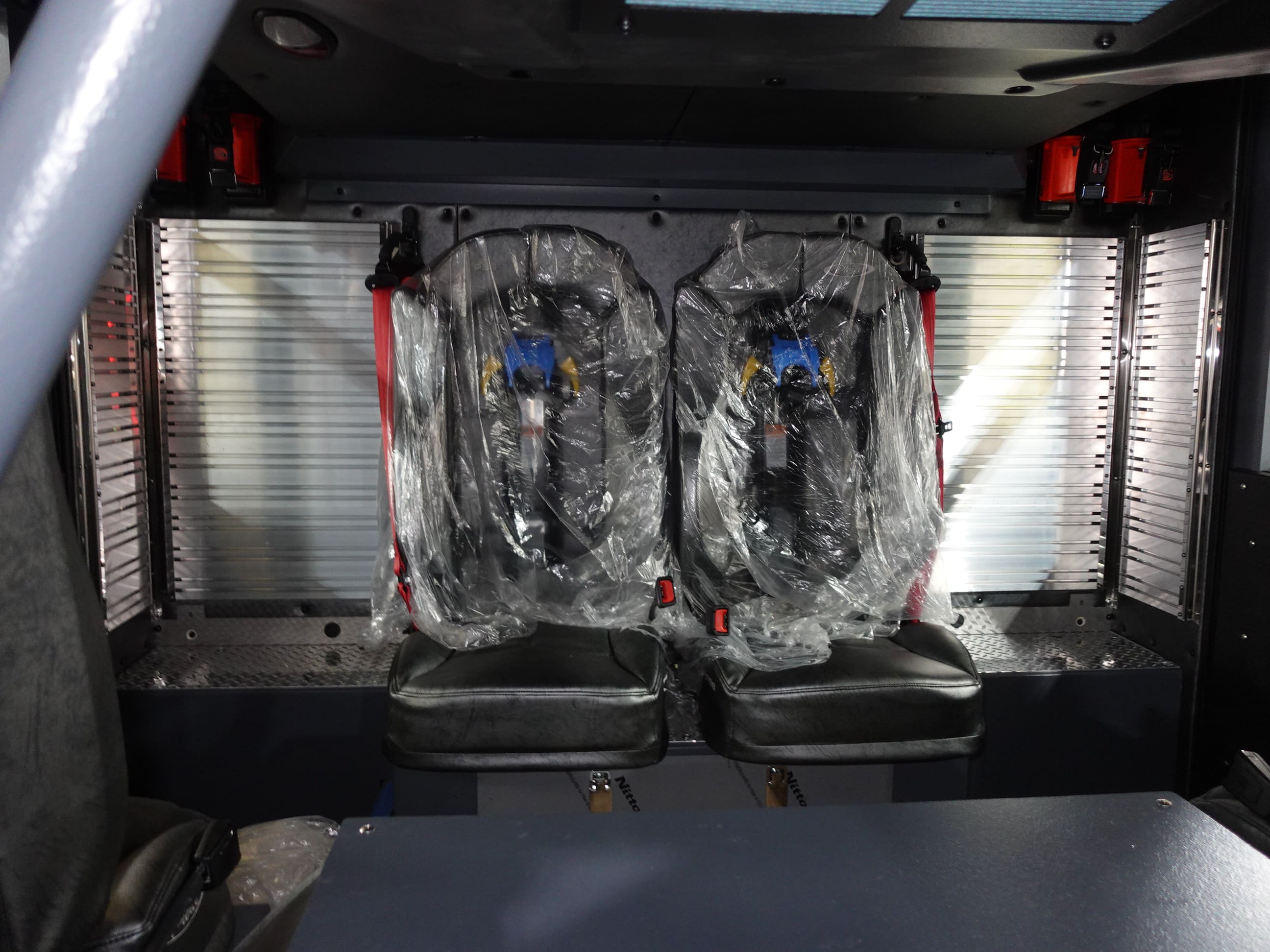

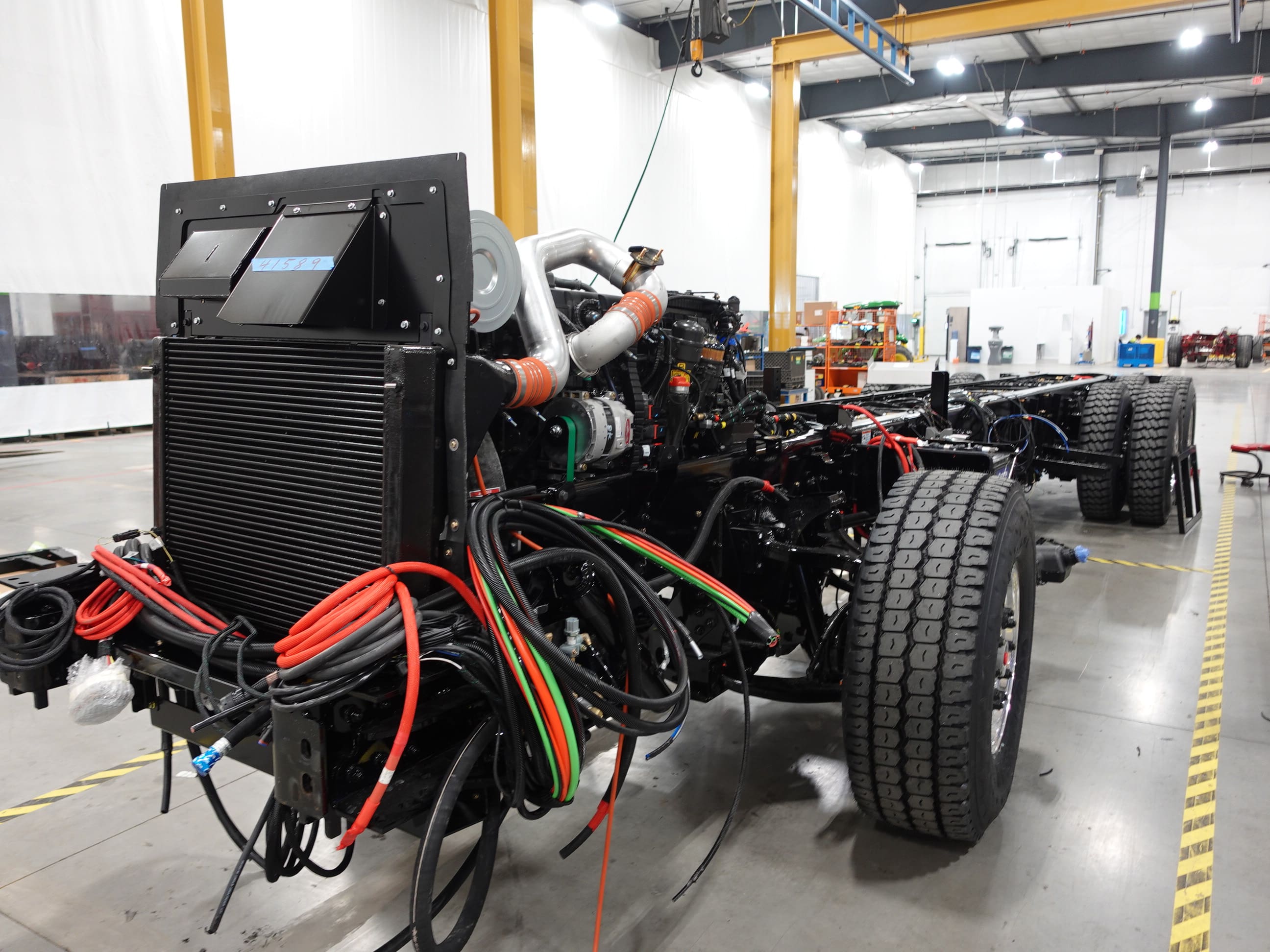

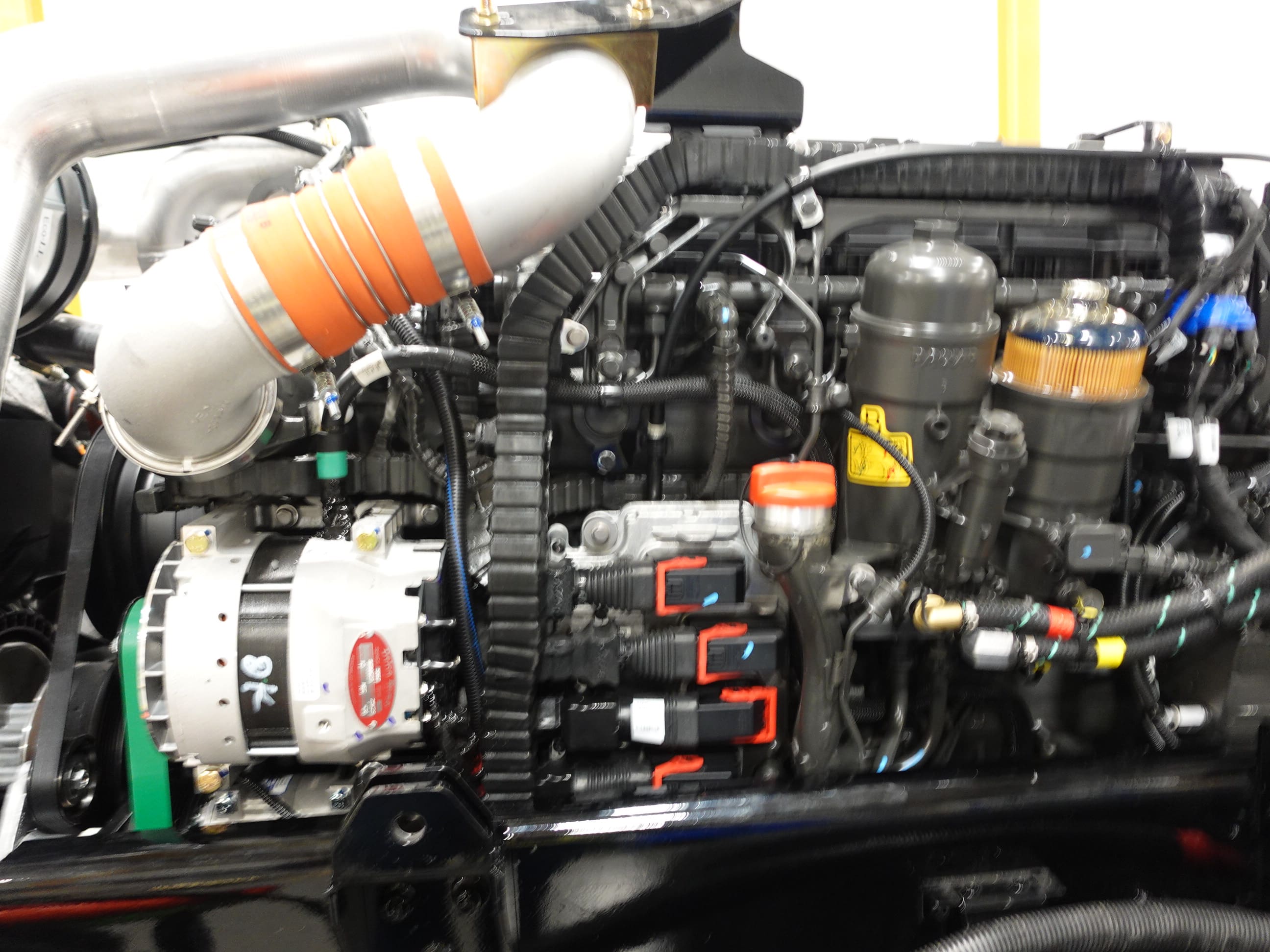

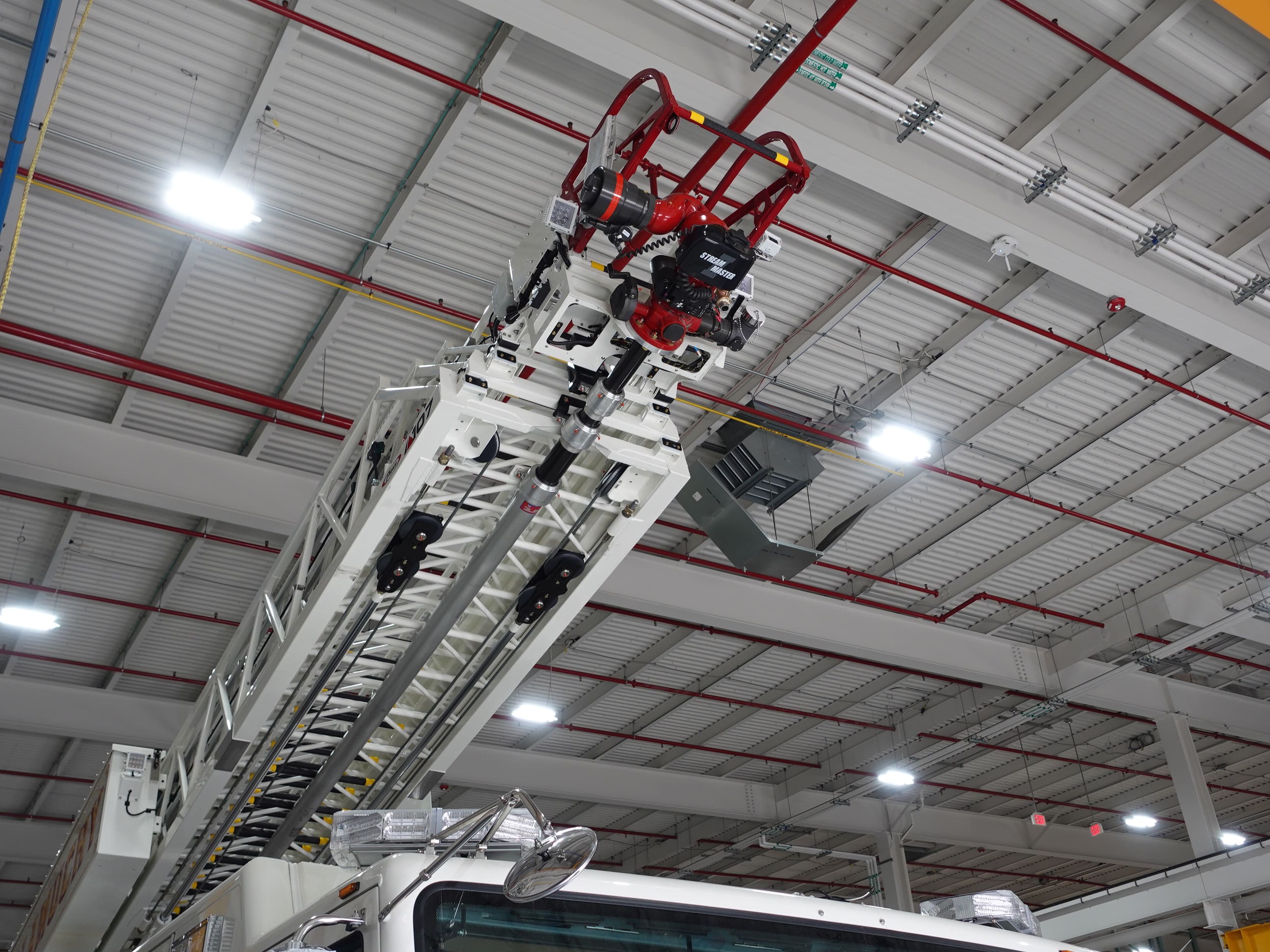

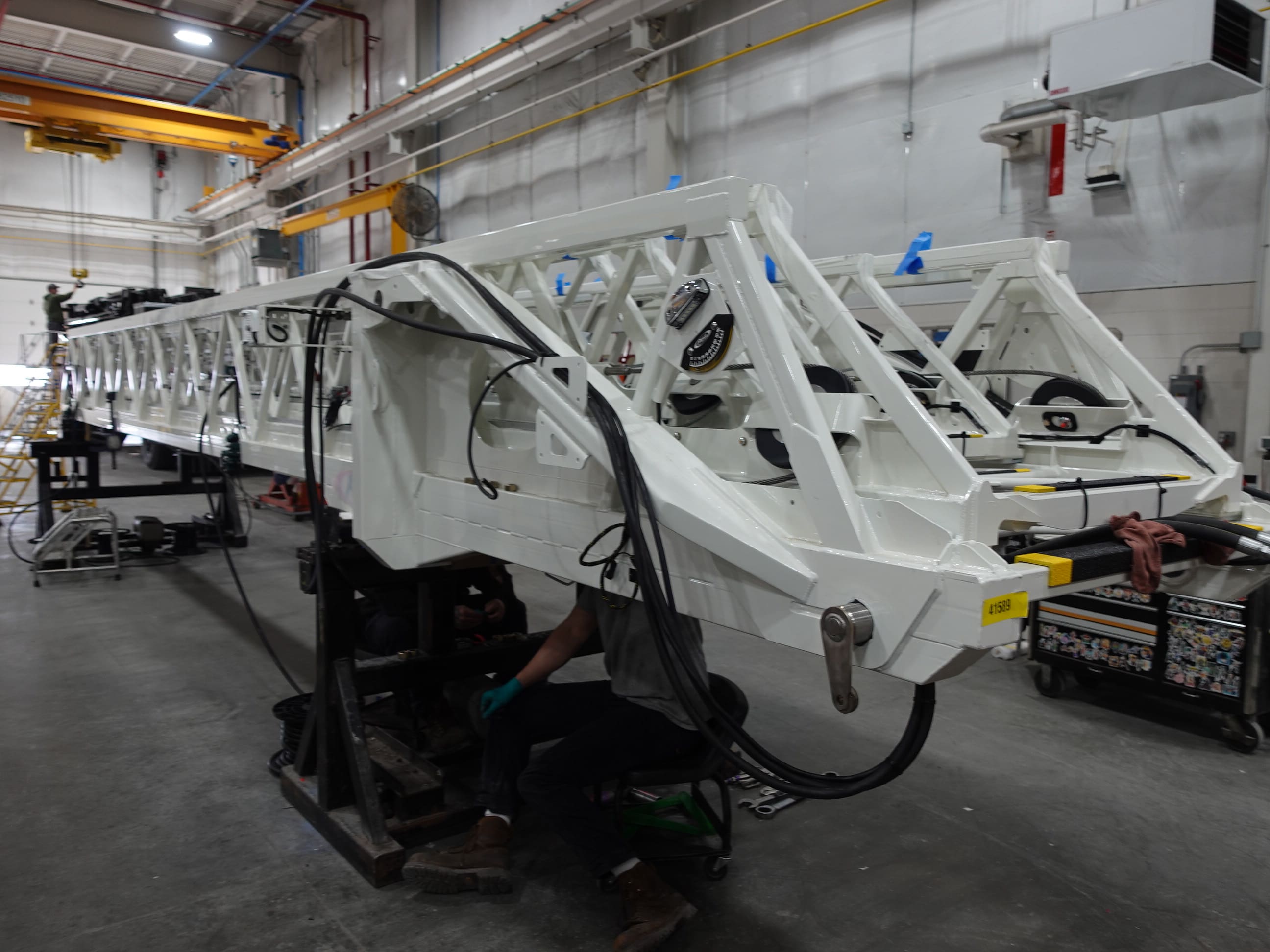

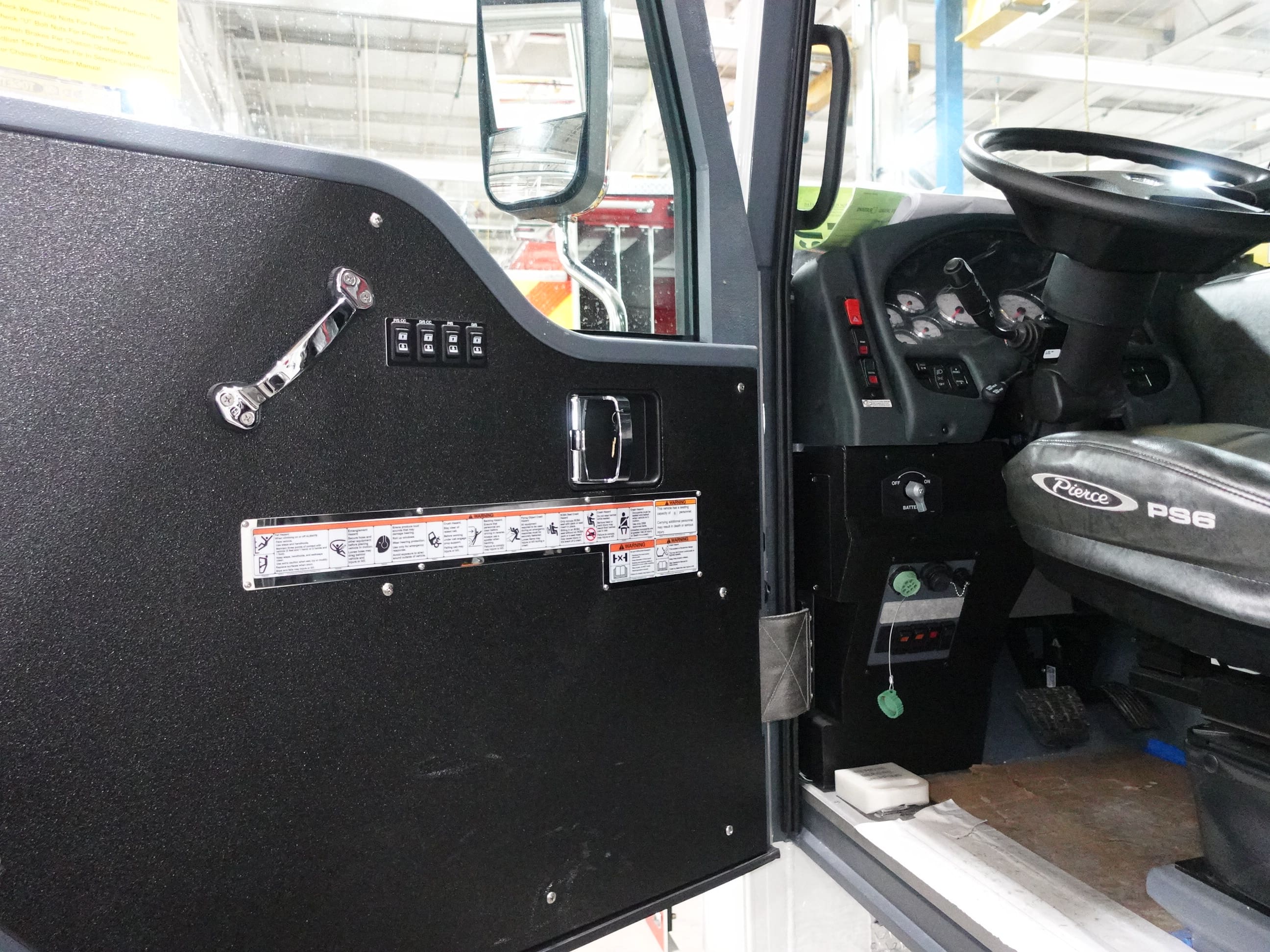

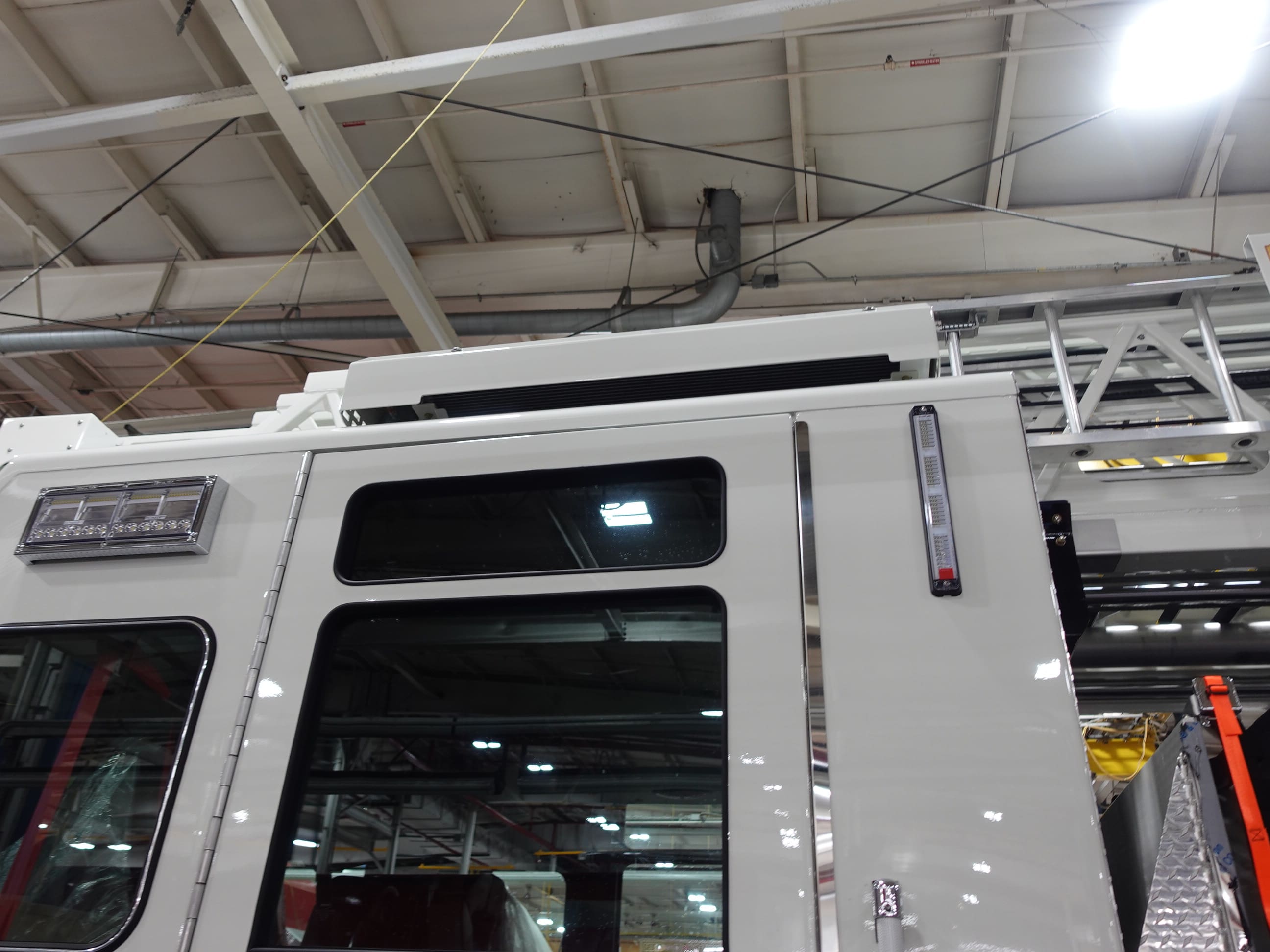

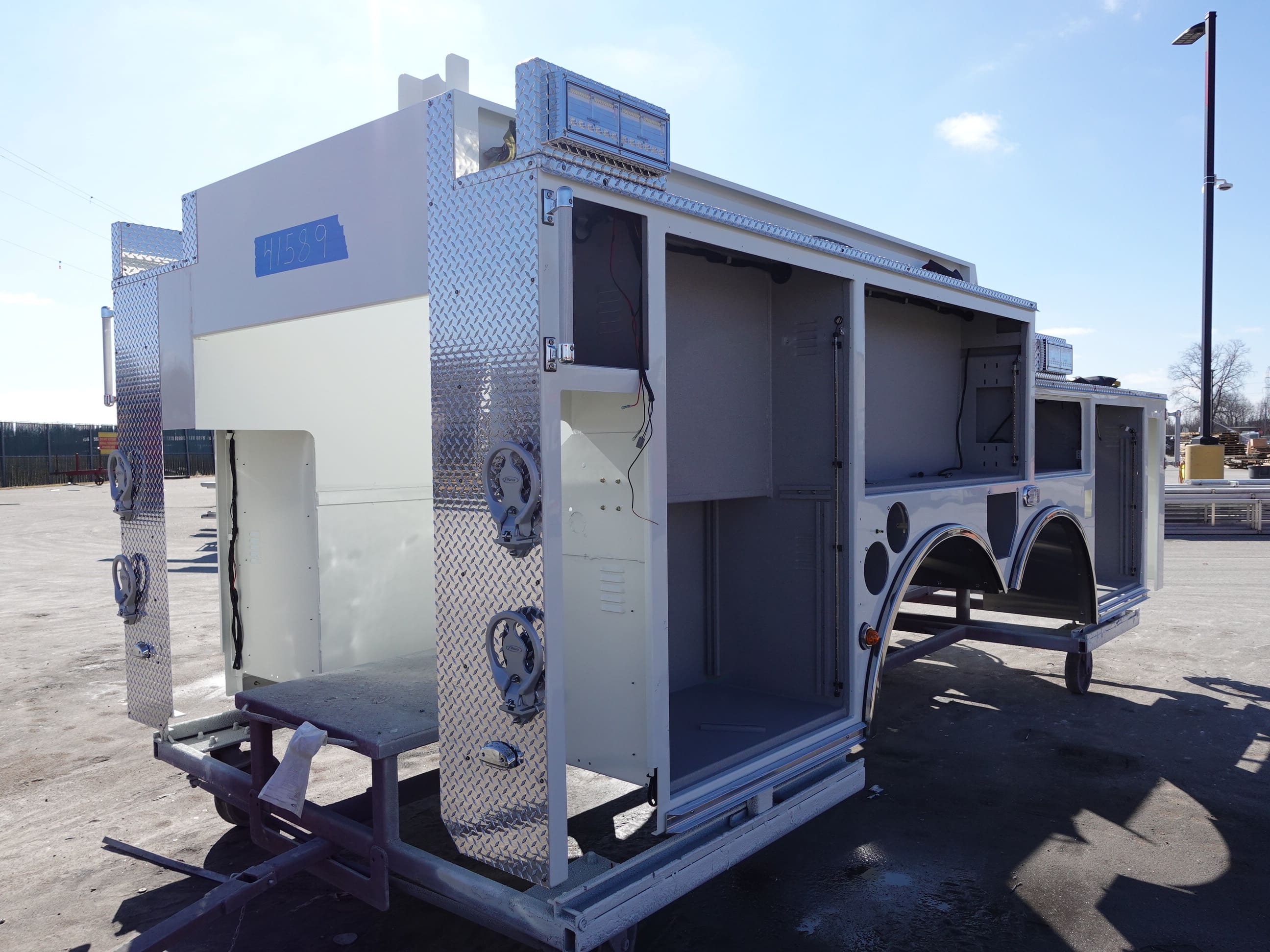

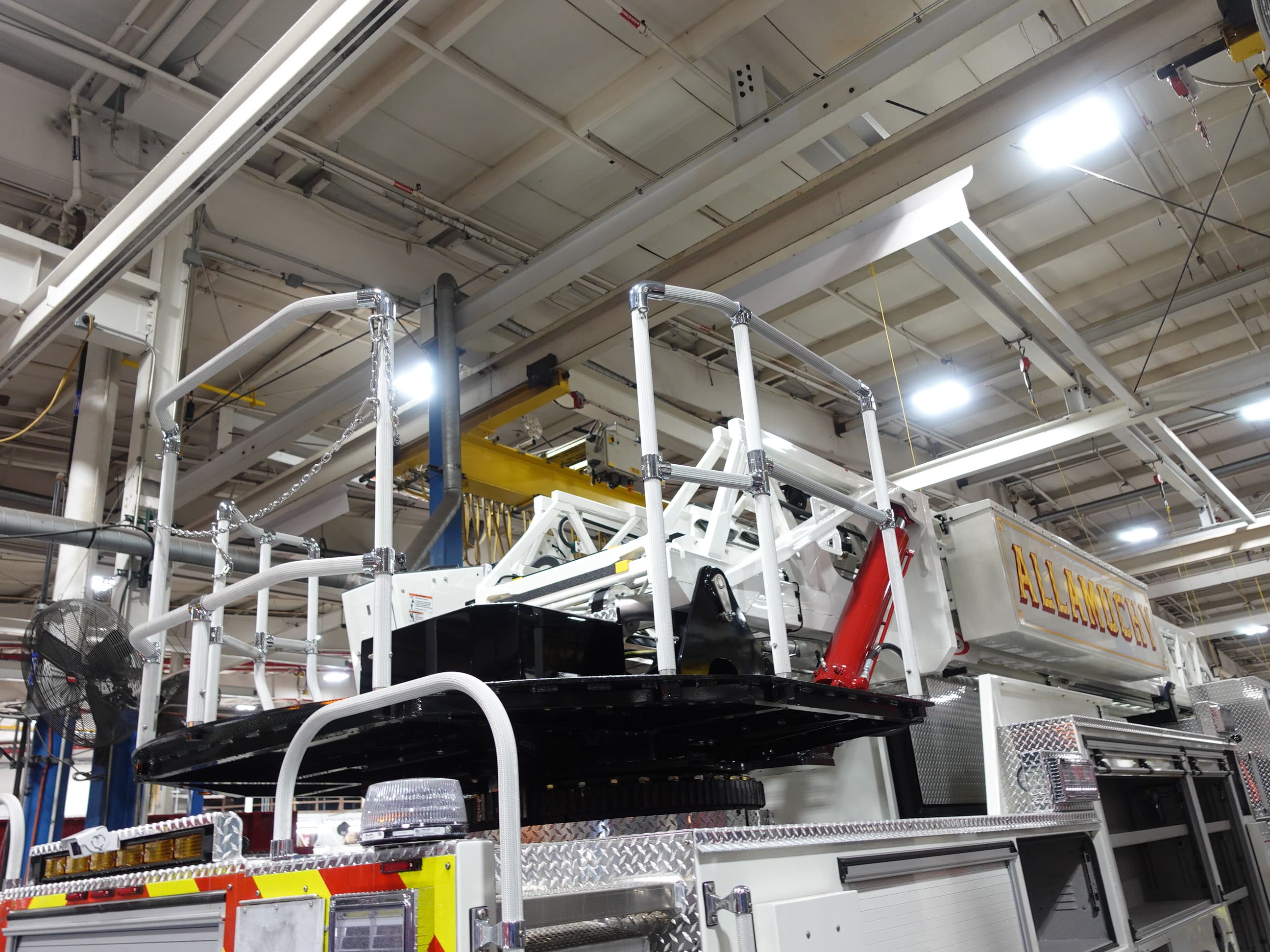

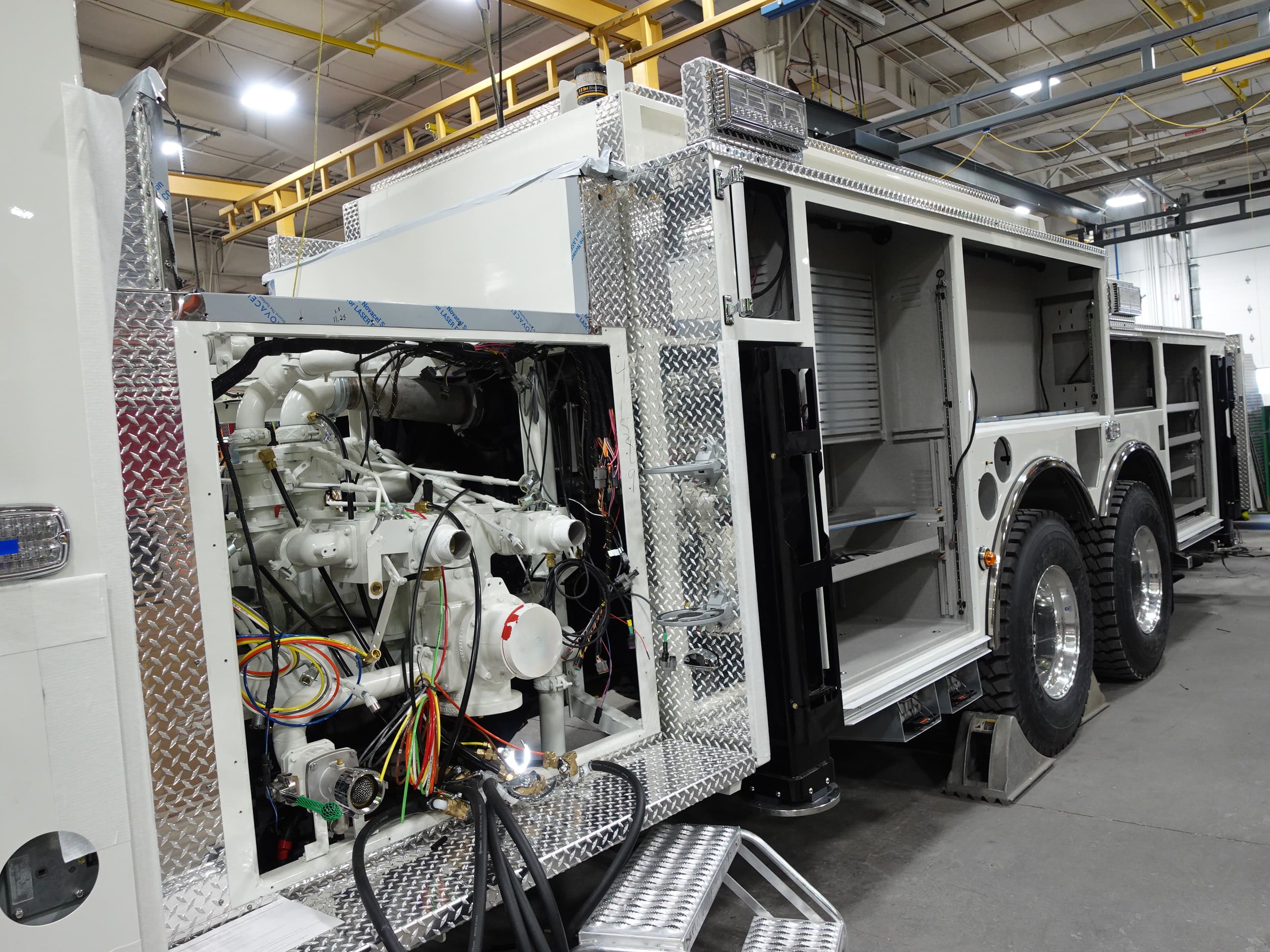

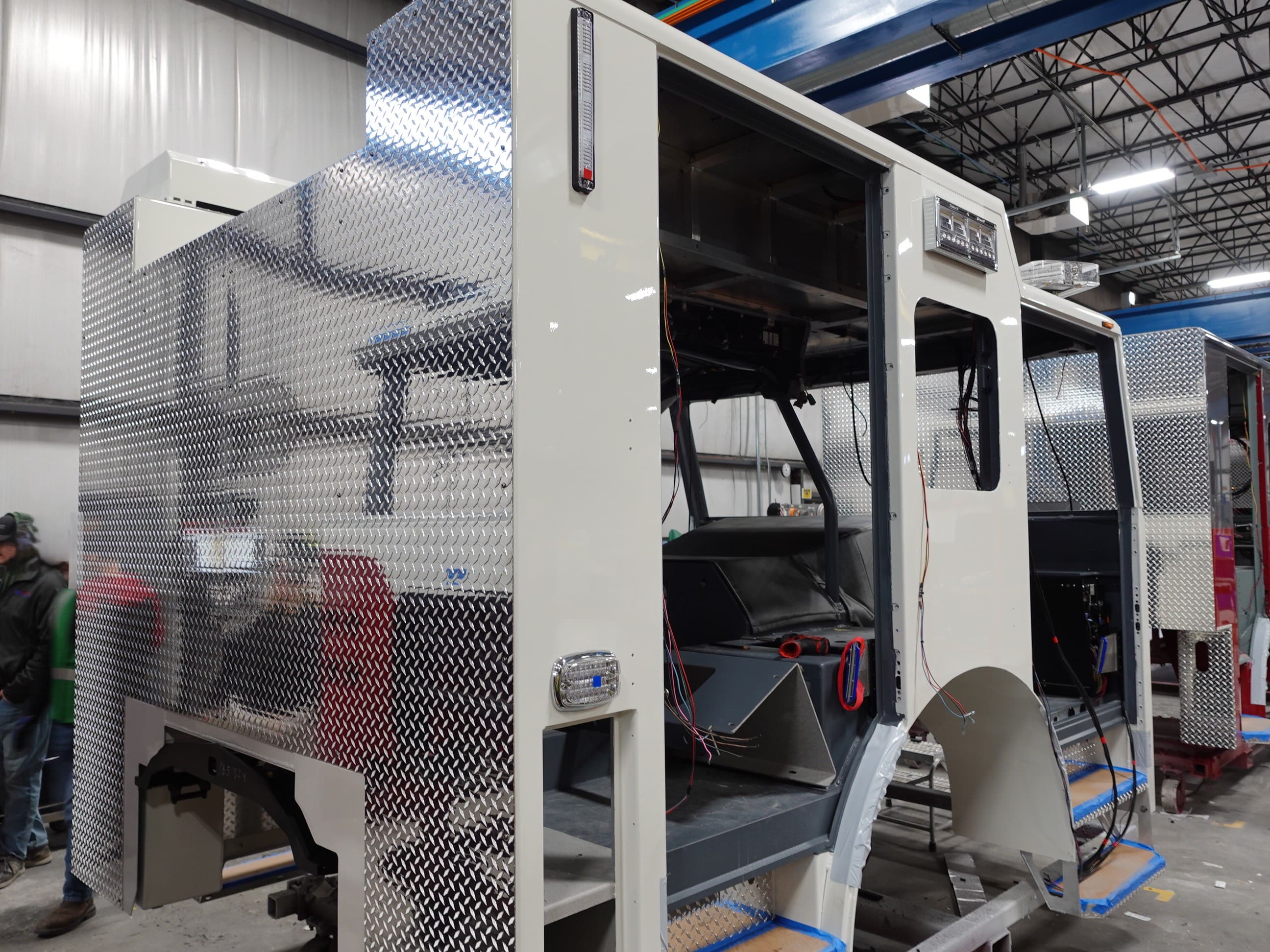

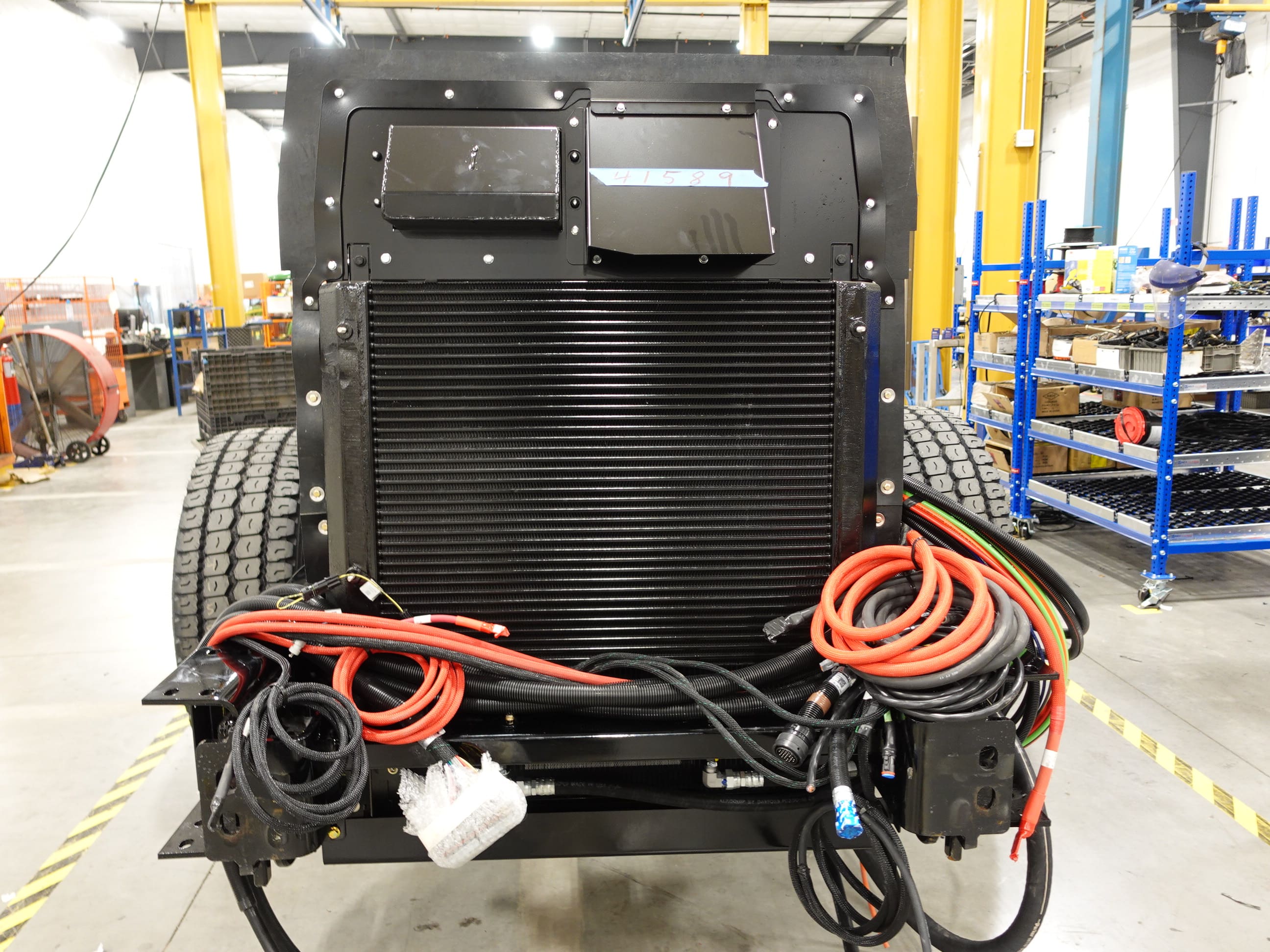

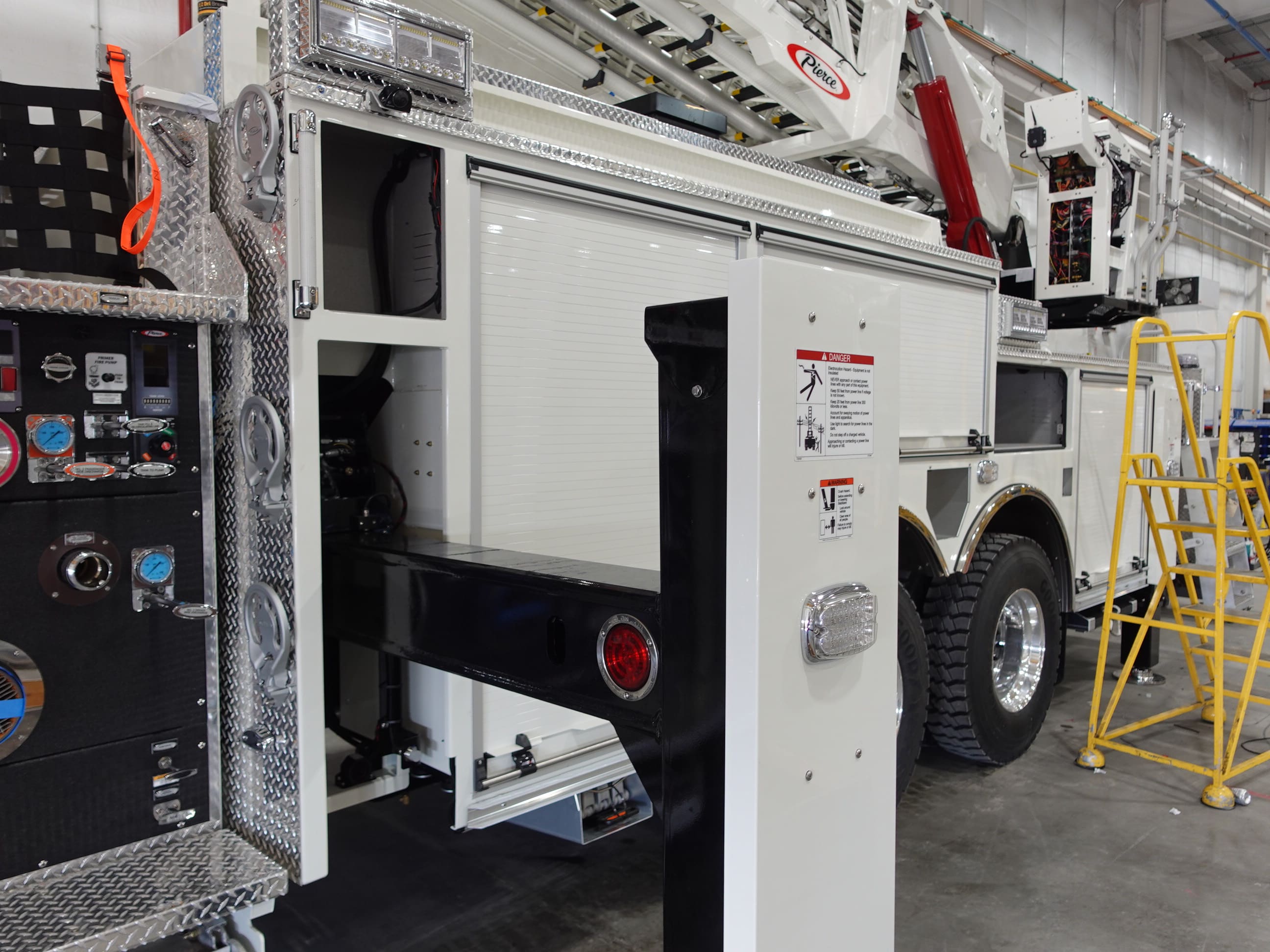

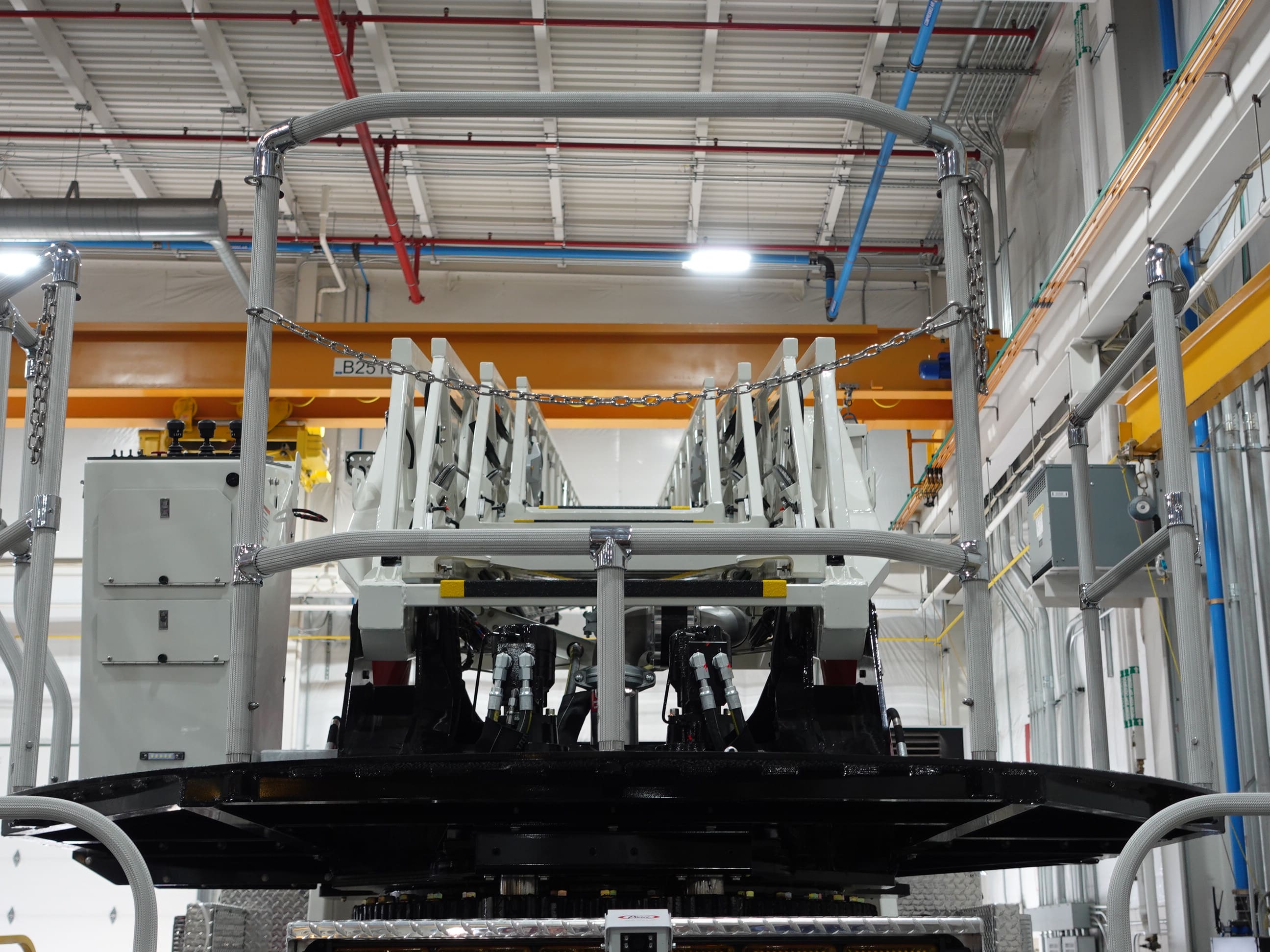

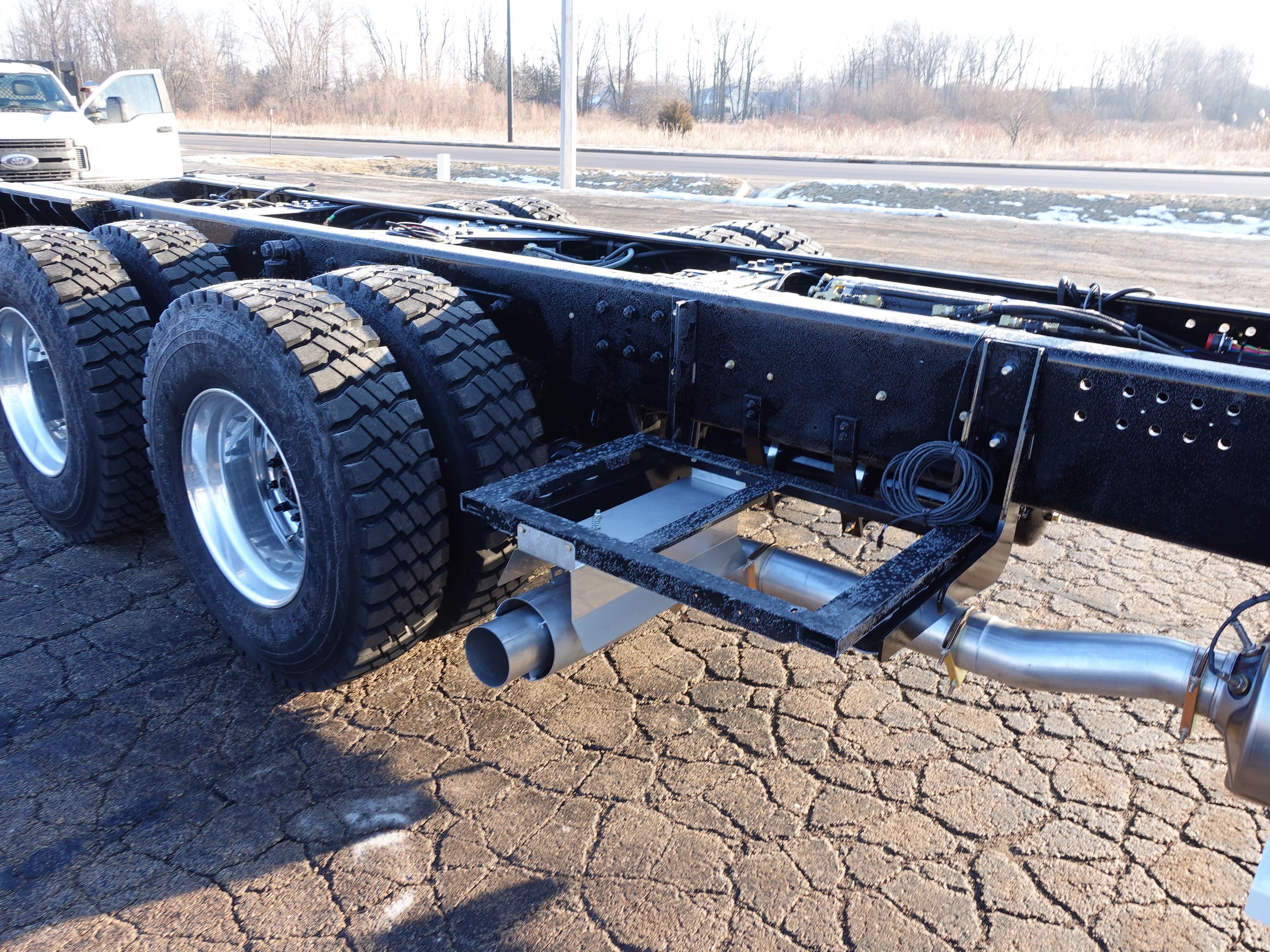

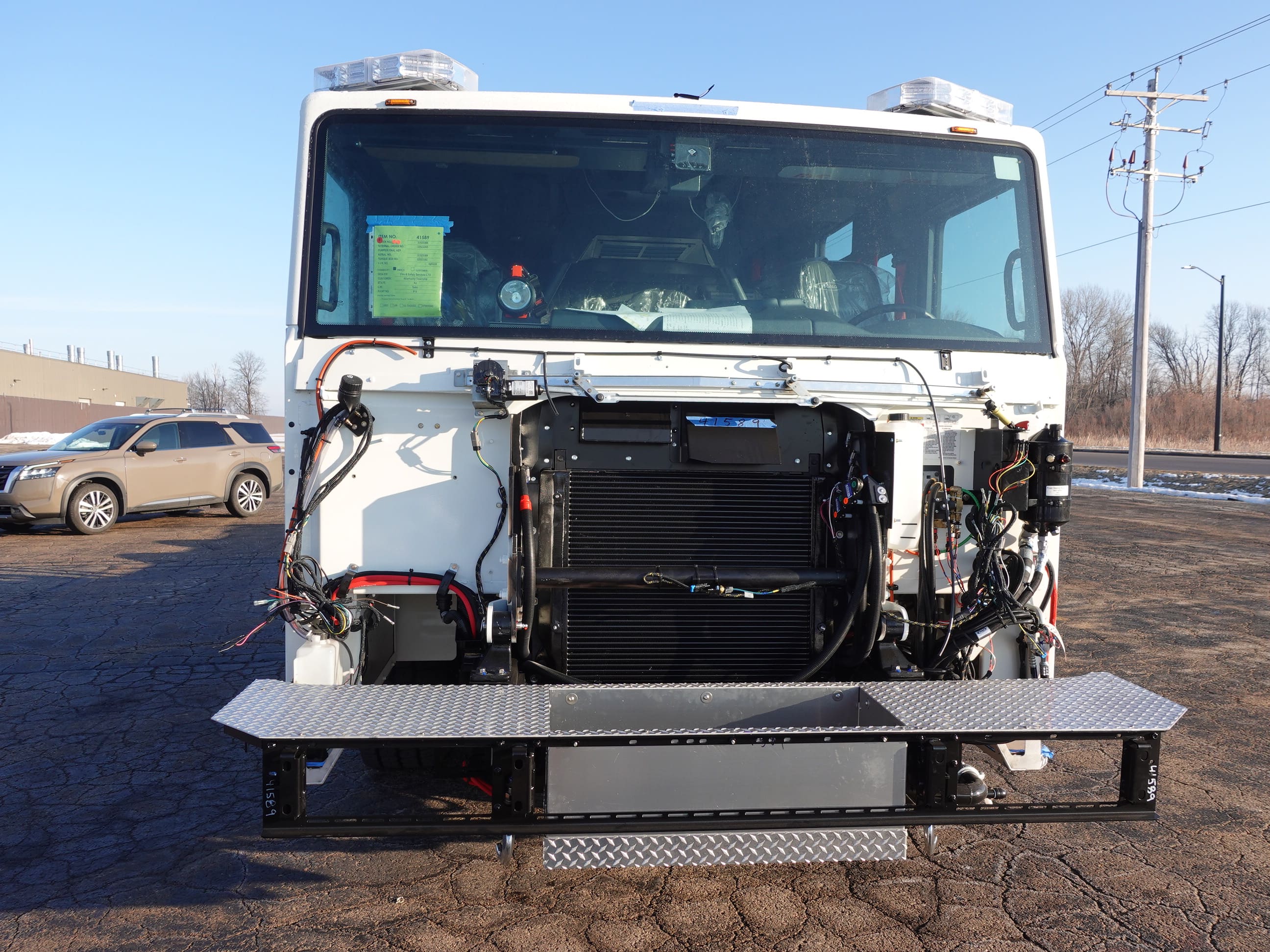

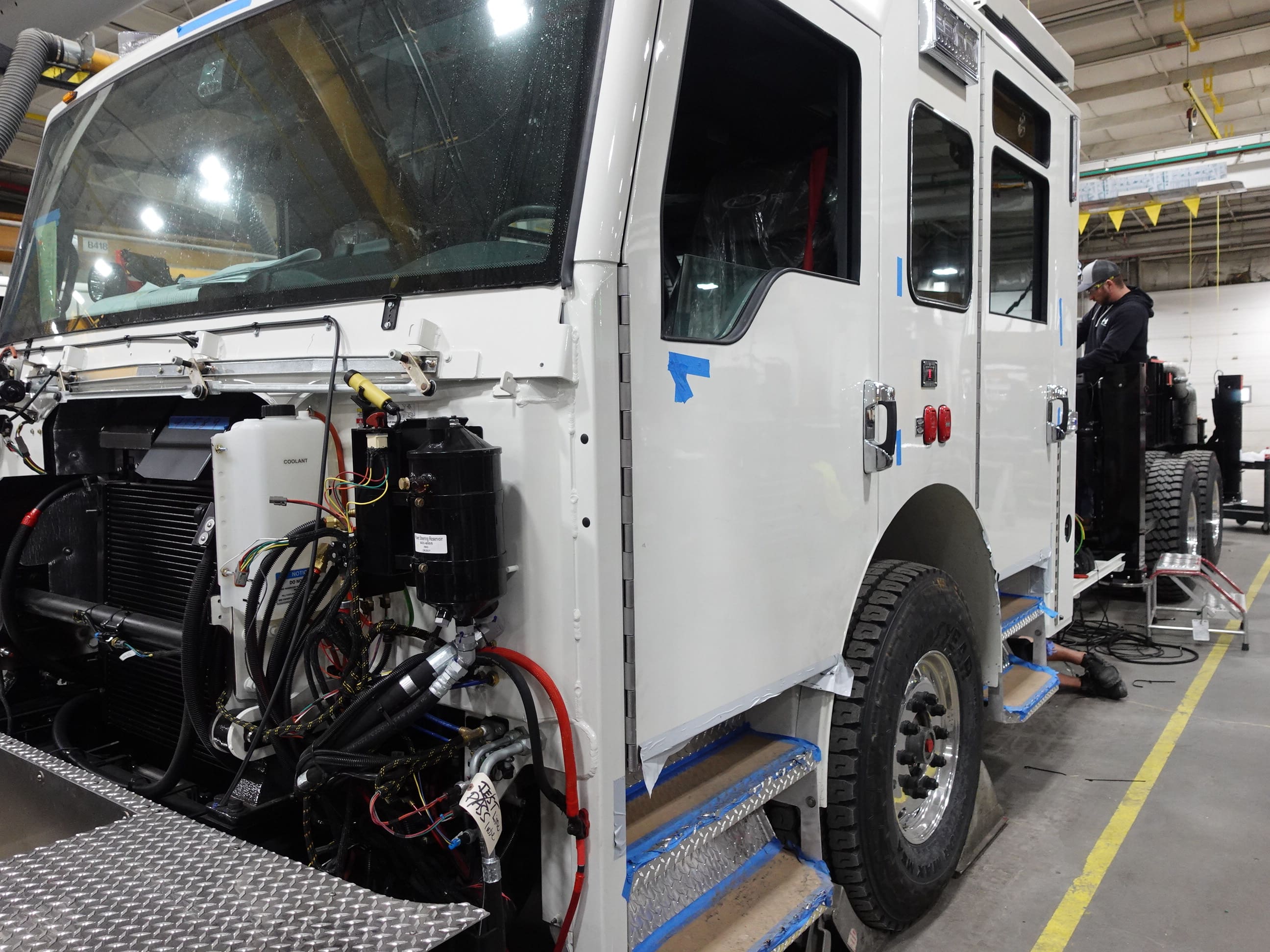

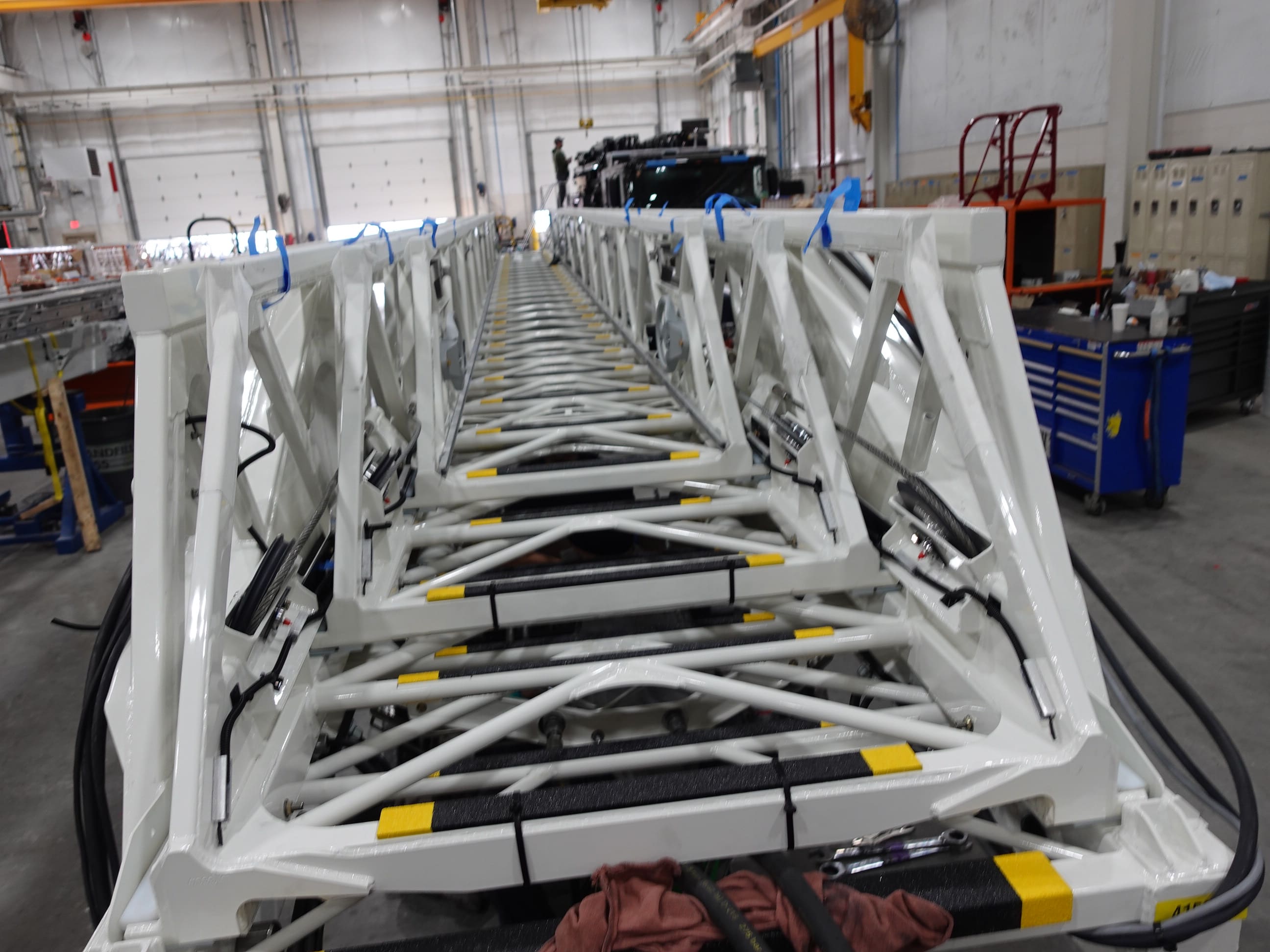

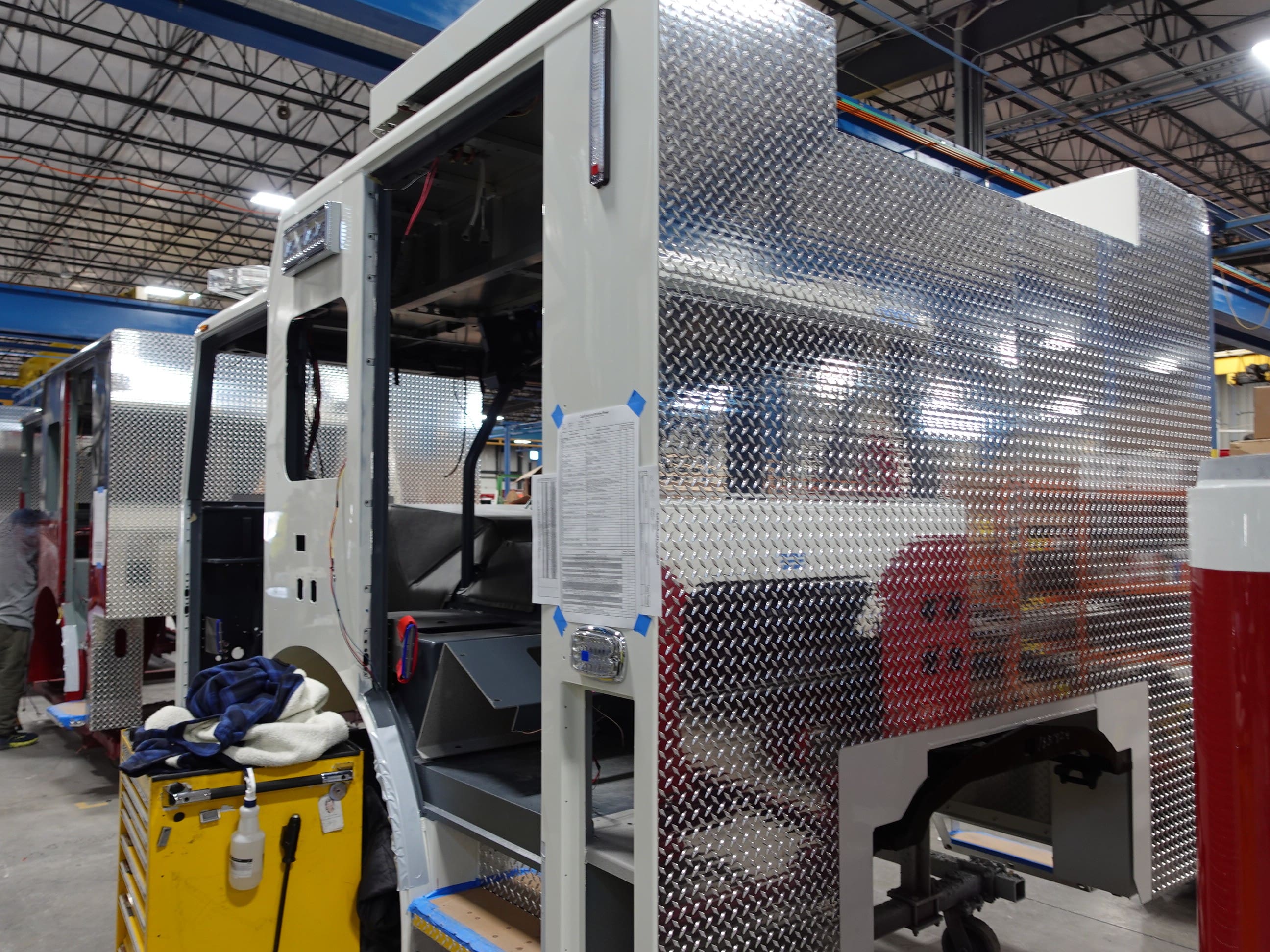

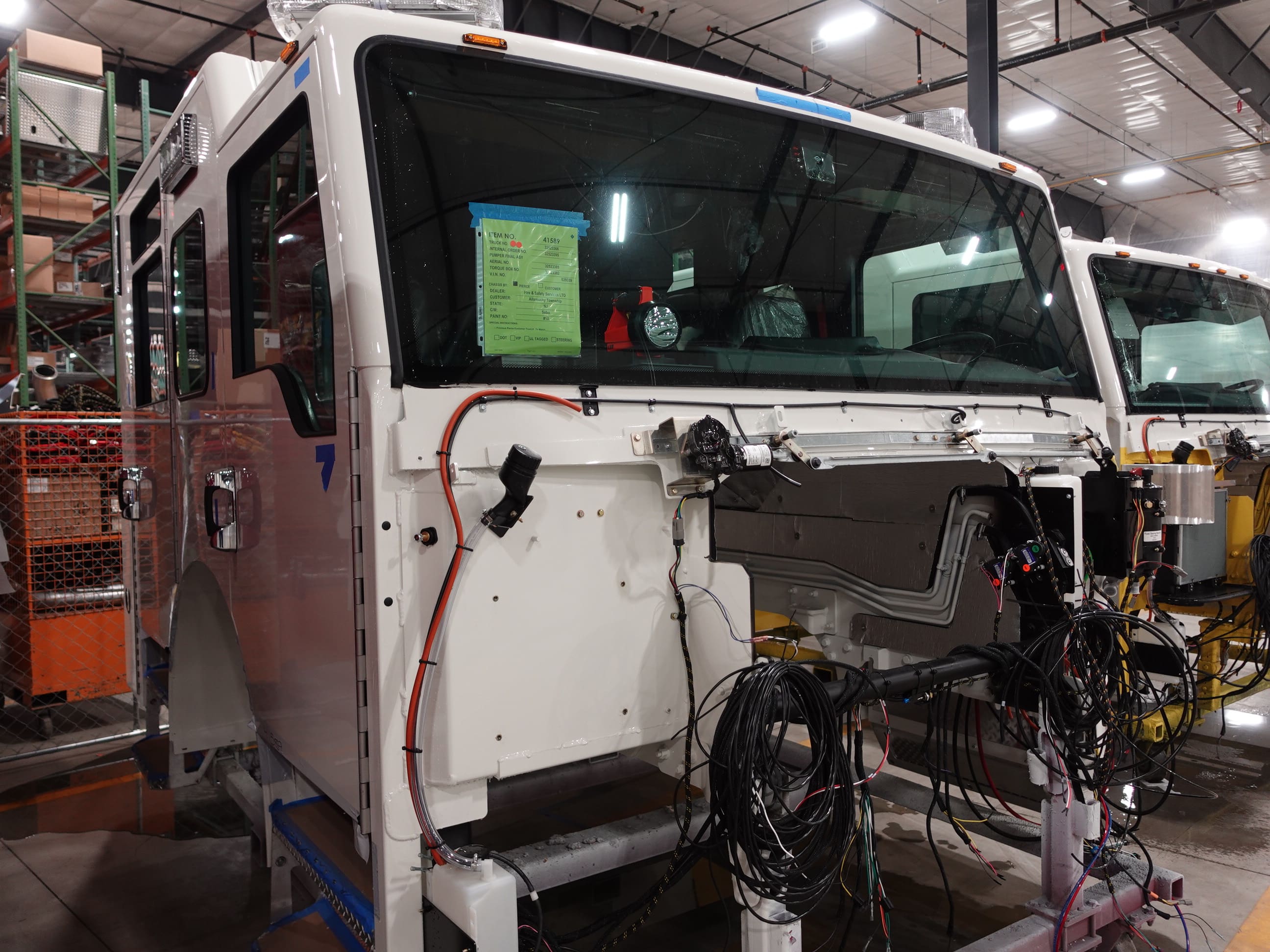

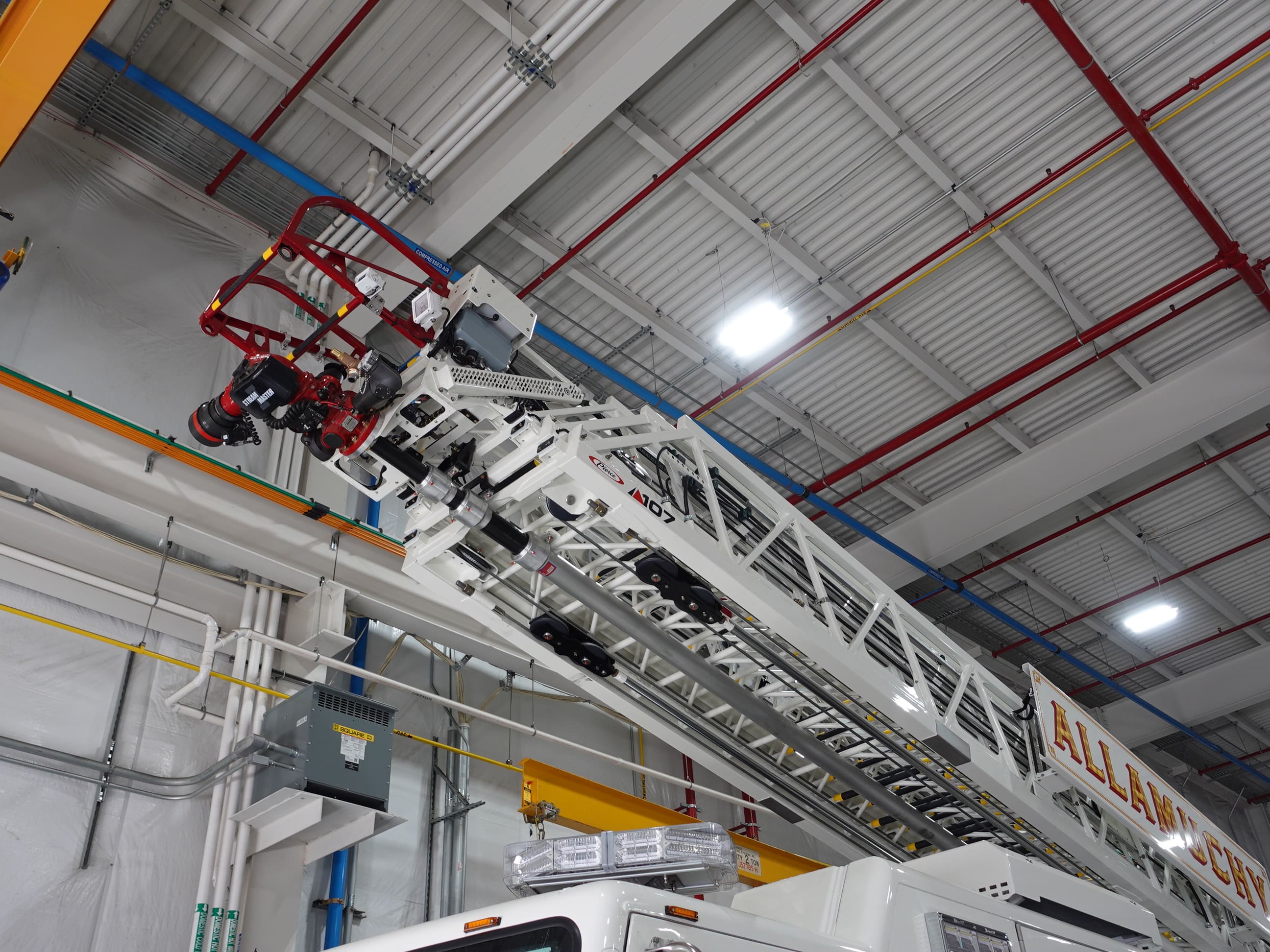

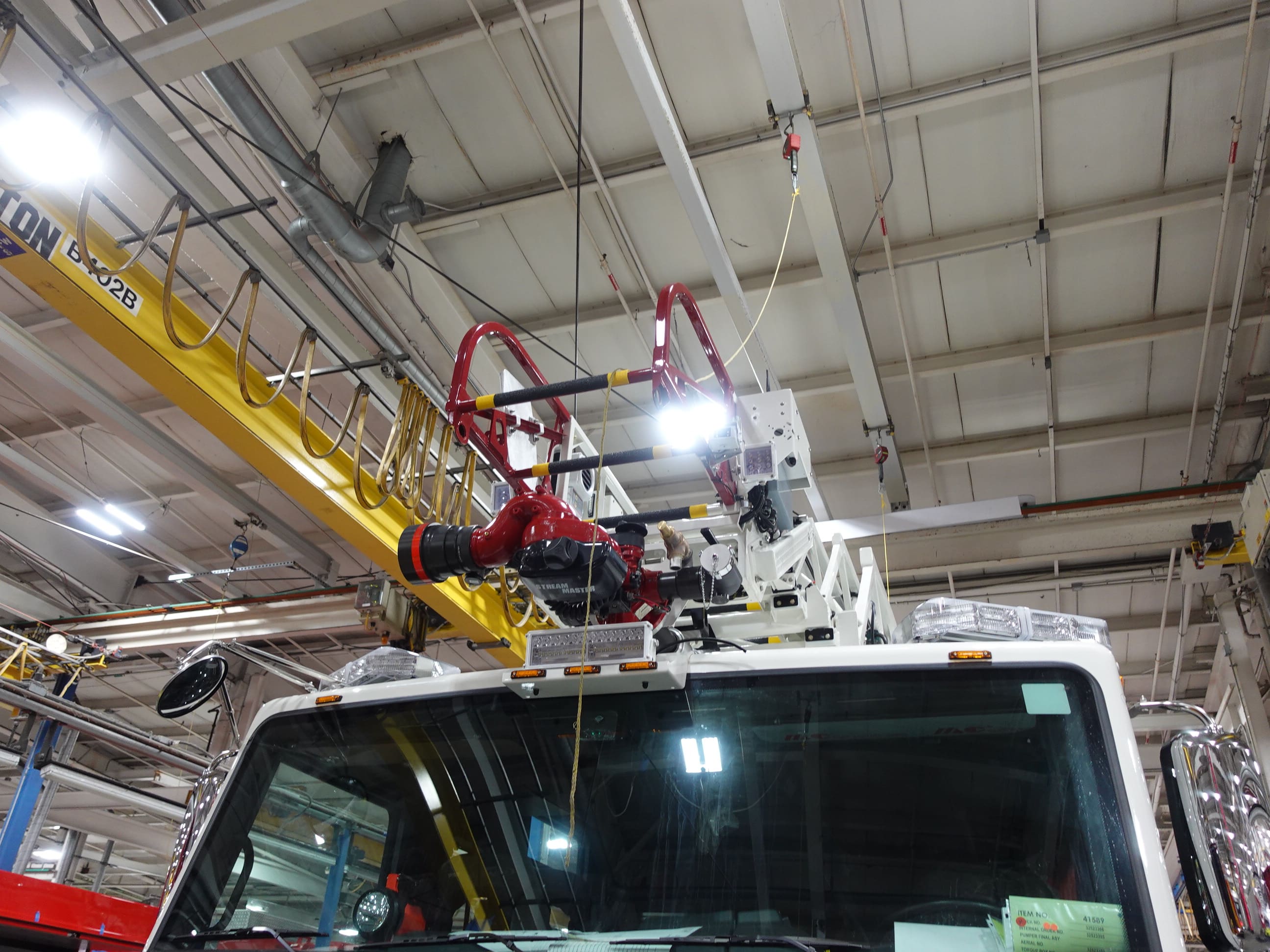

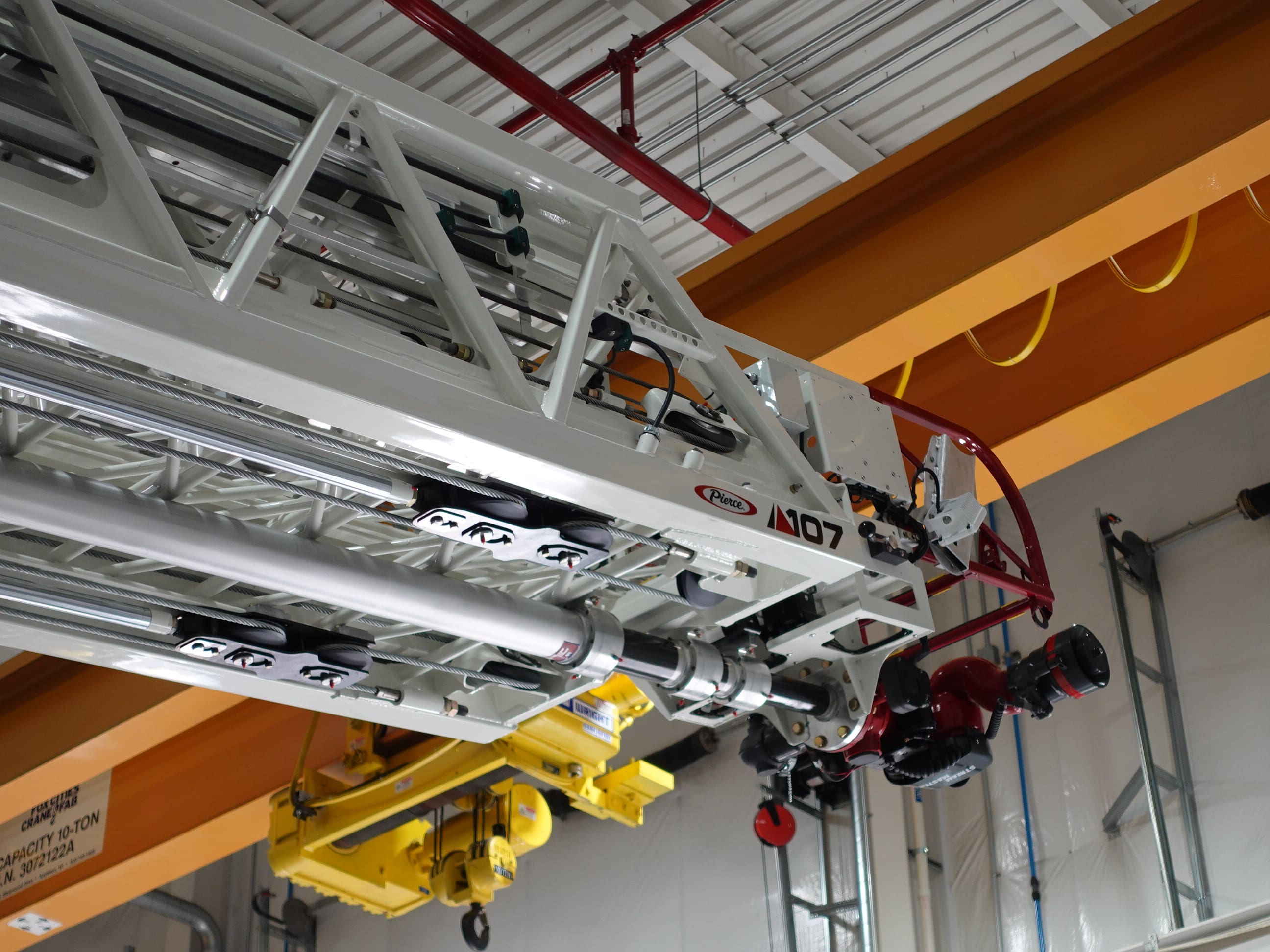

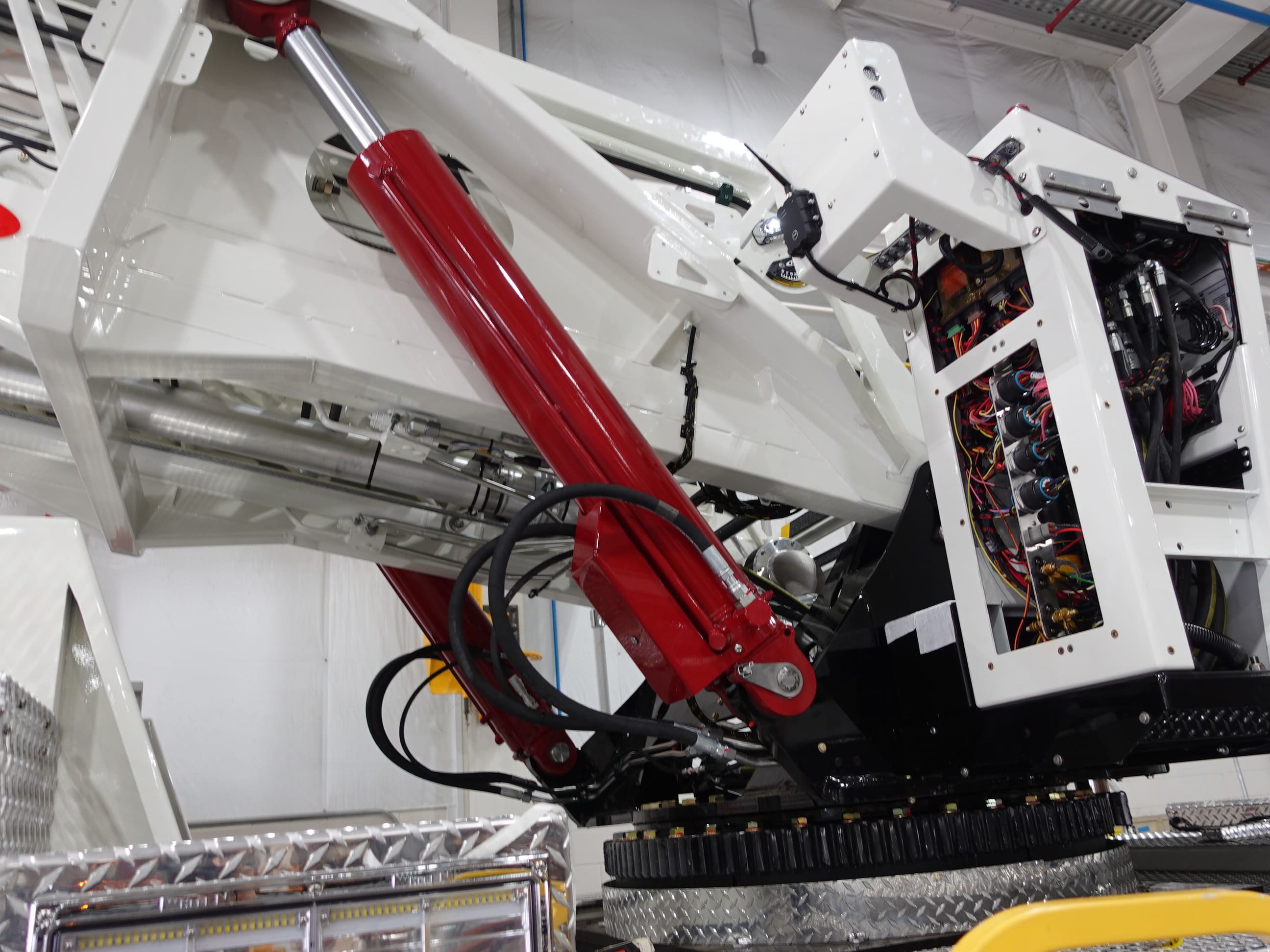

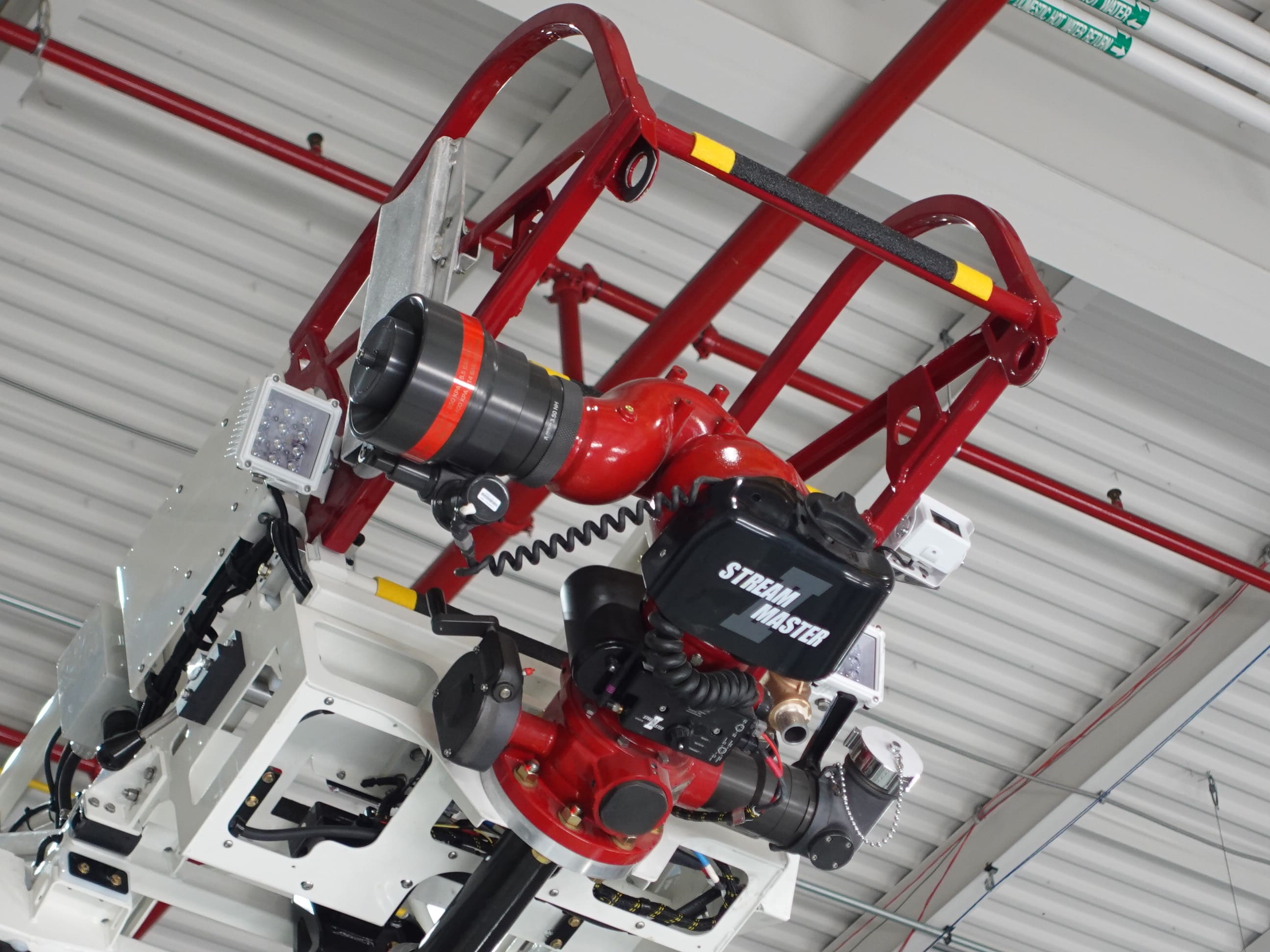

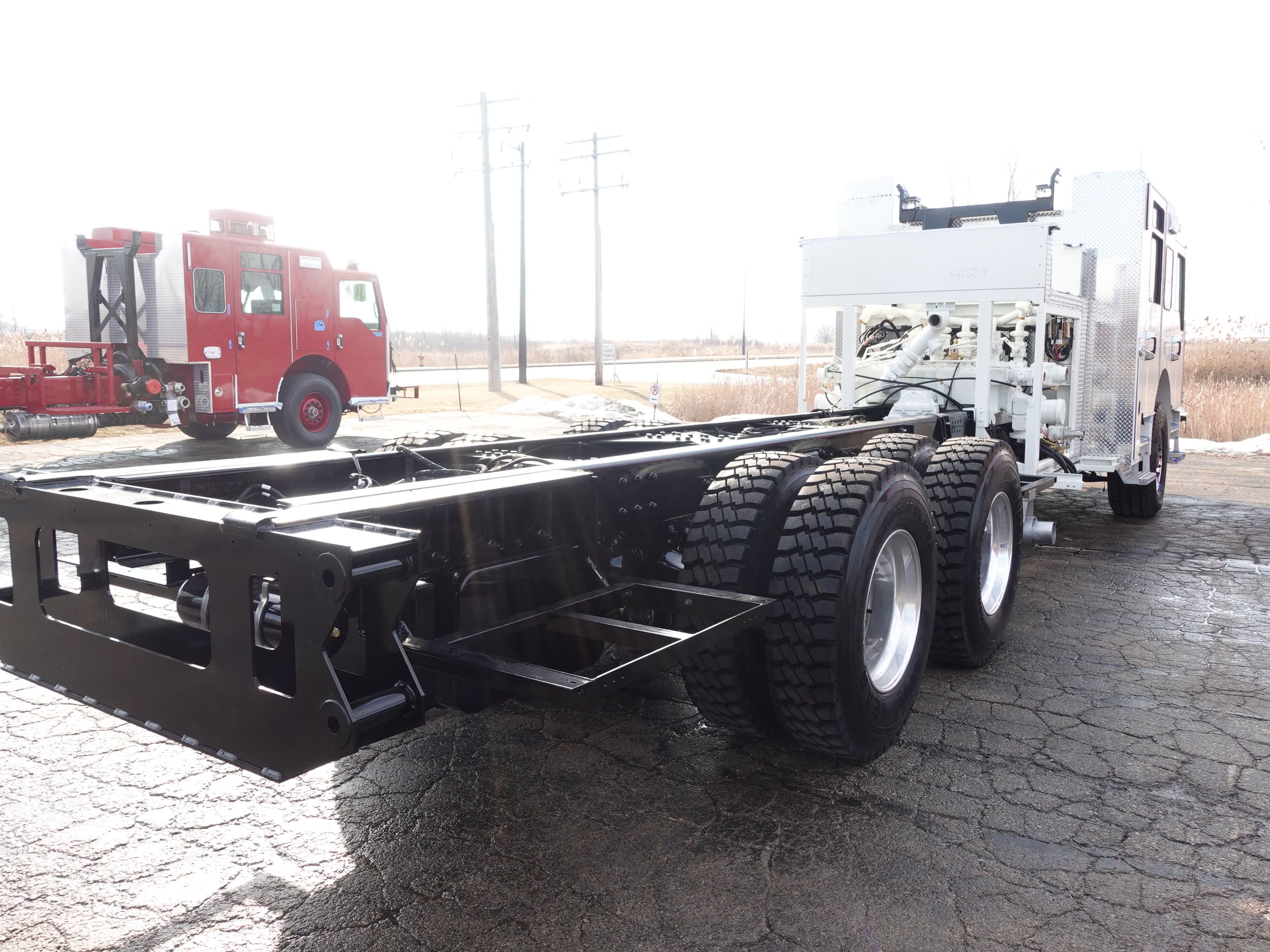

In this report, the apparatus completed final assembly while the aerial device completed initial assembly and was being pinned to the apparatus.
02-27-26

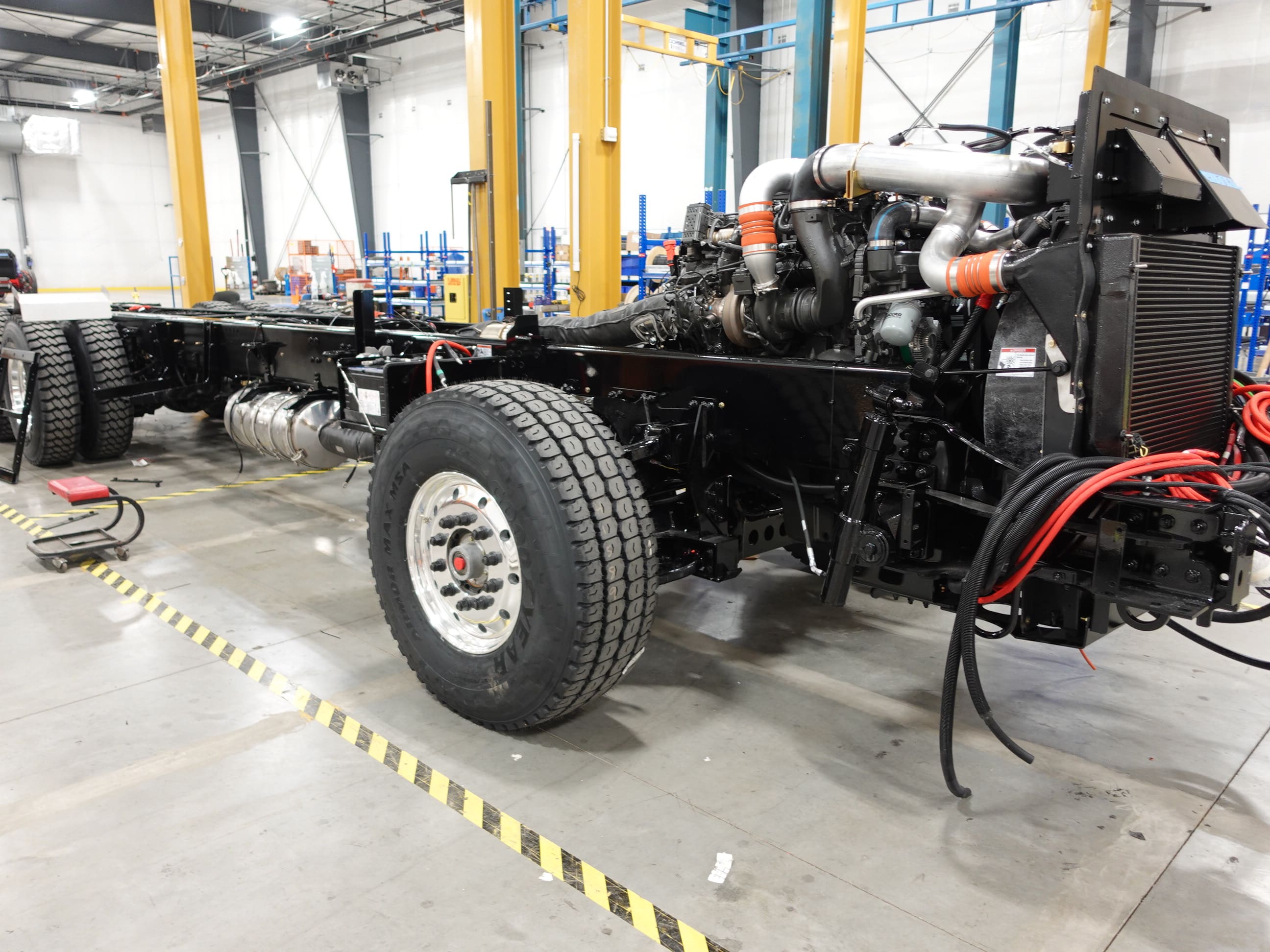

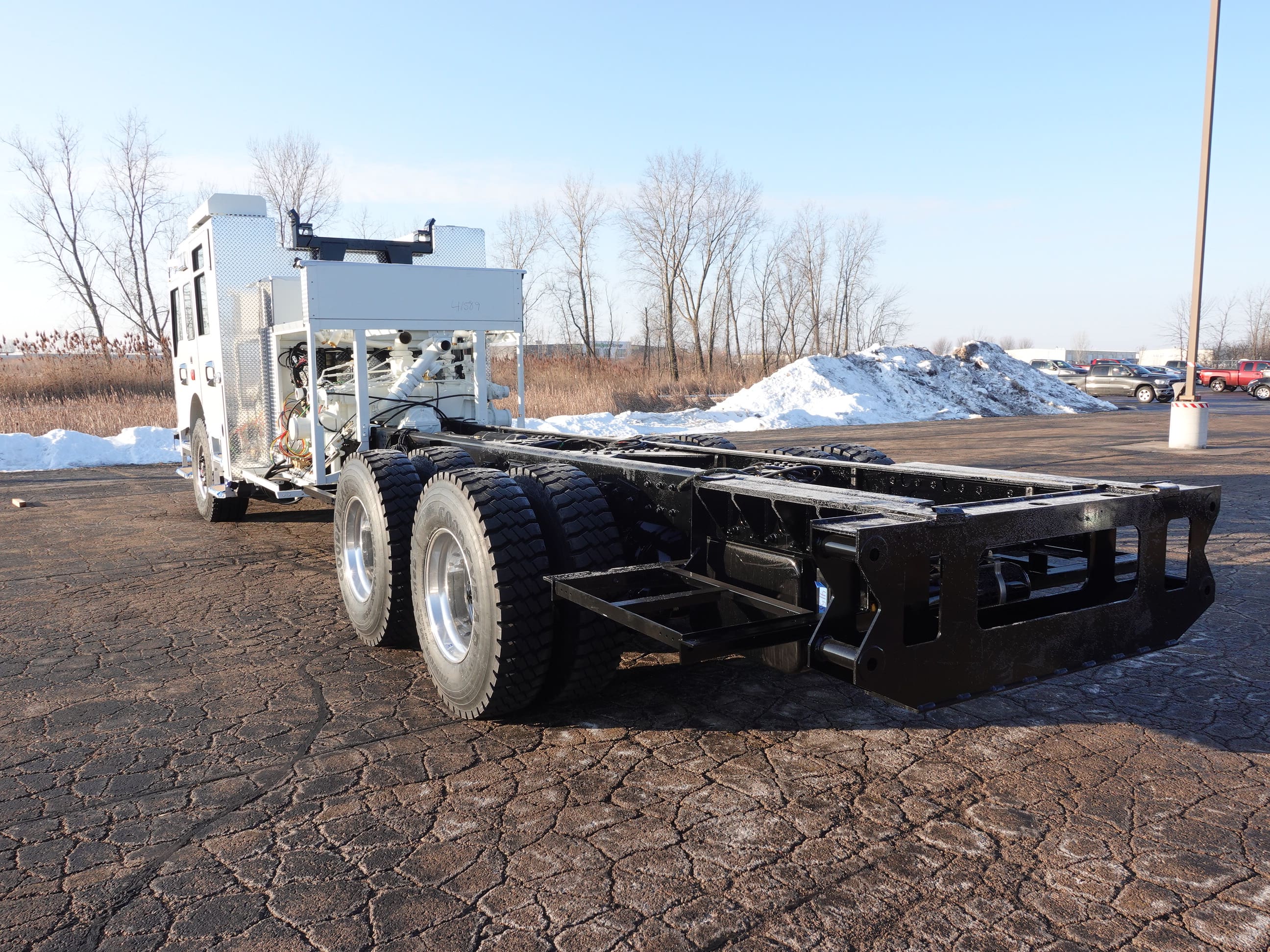

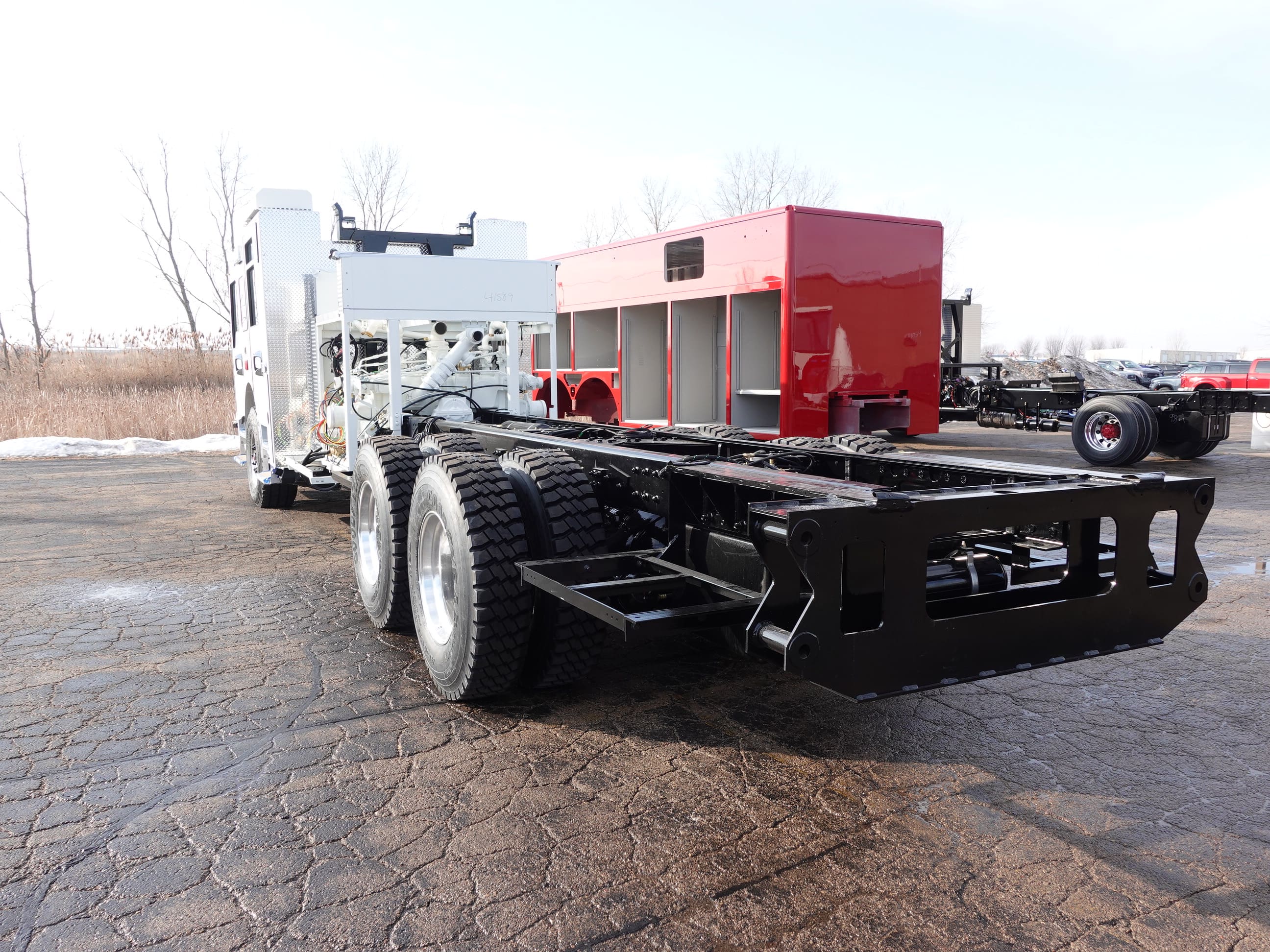

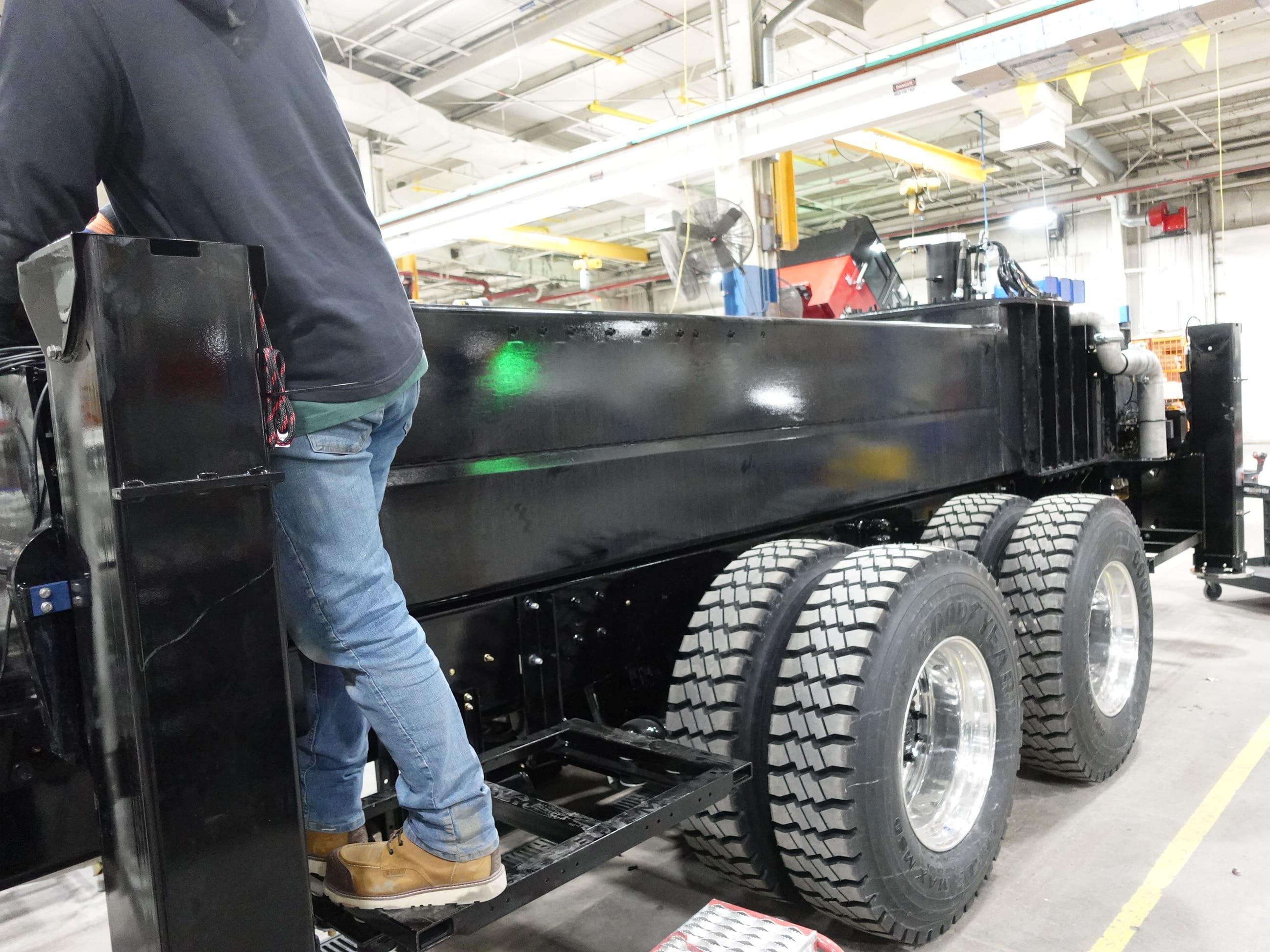

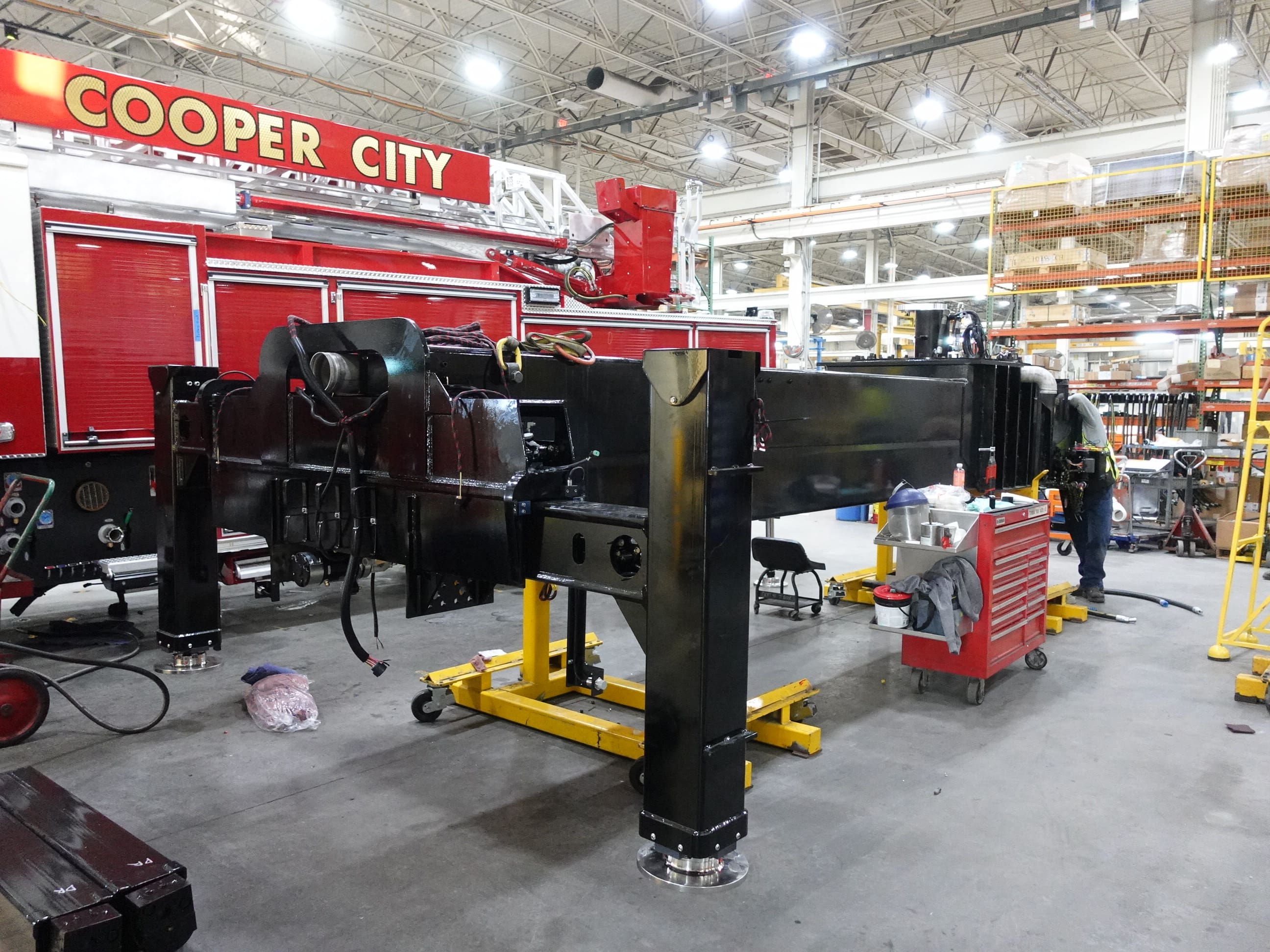

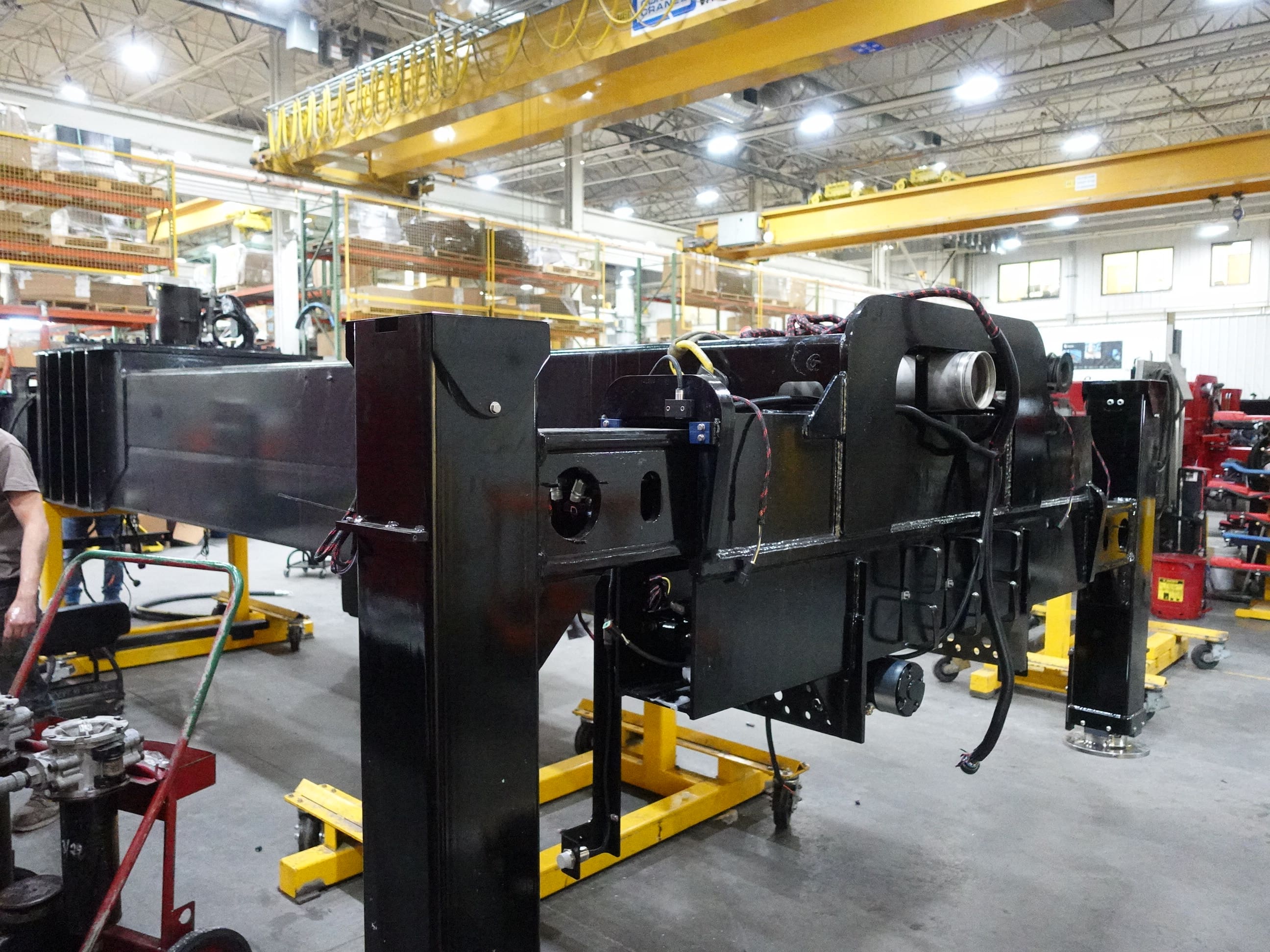

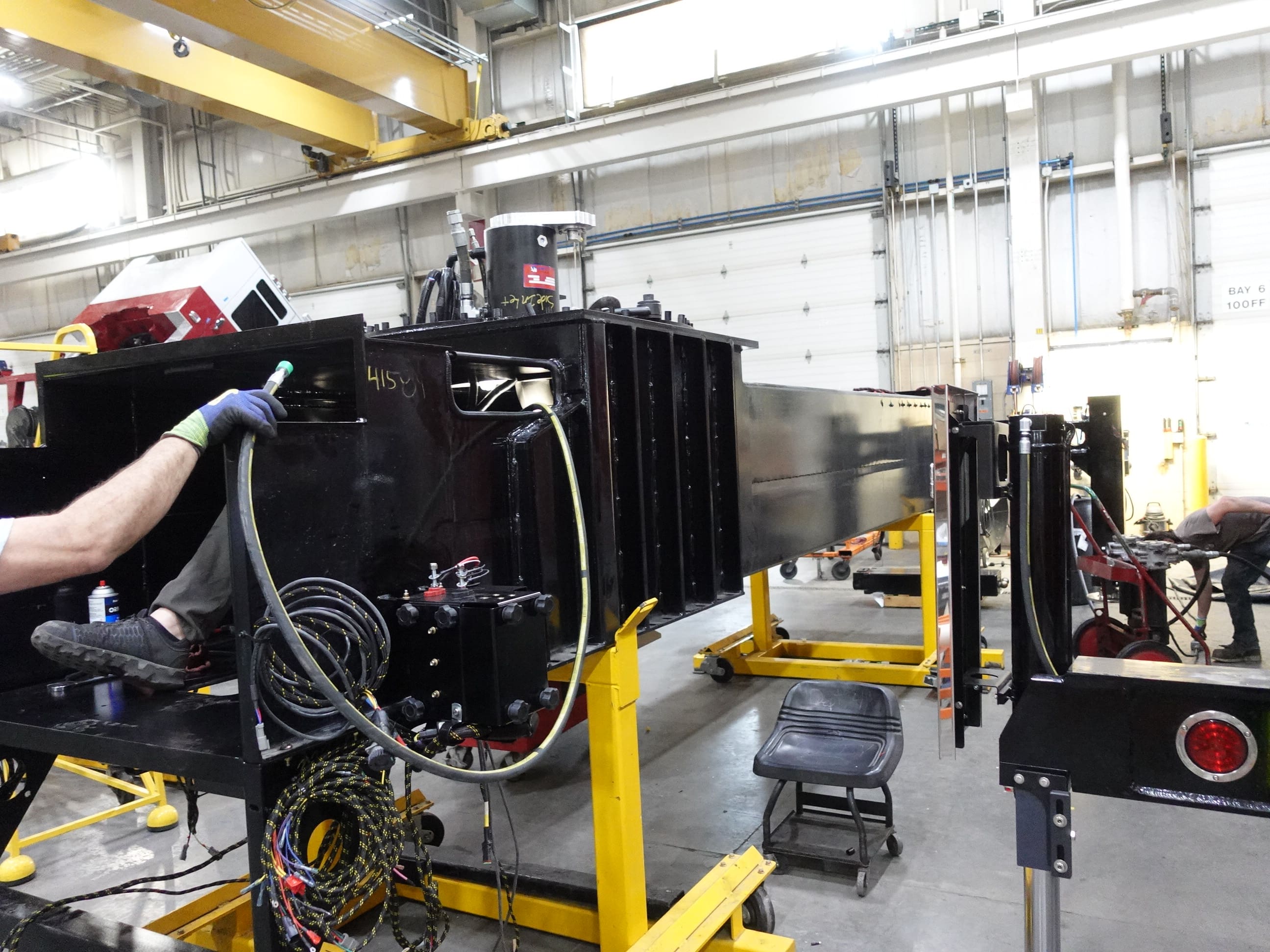

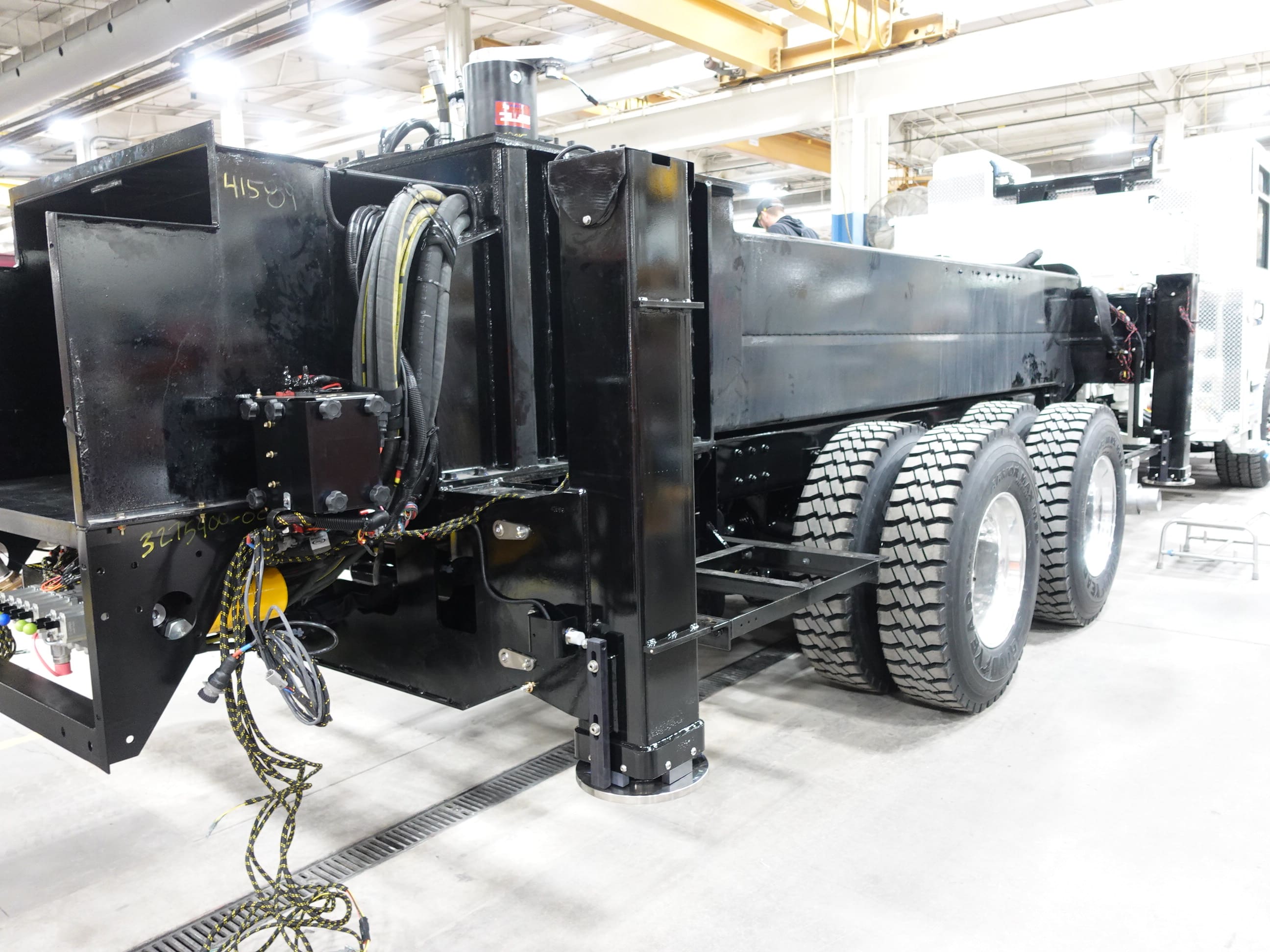

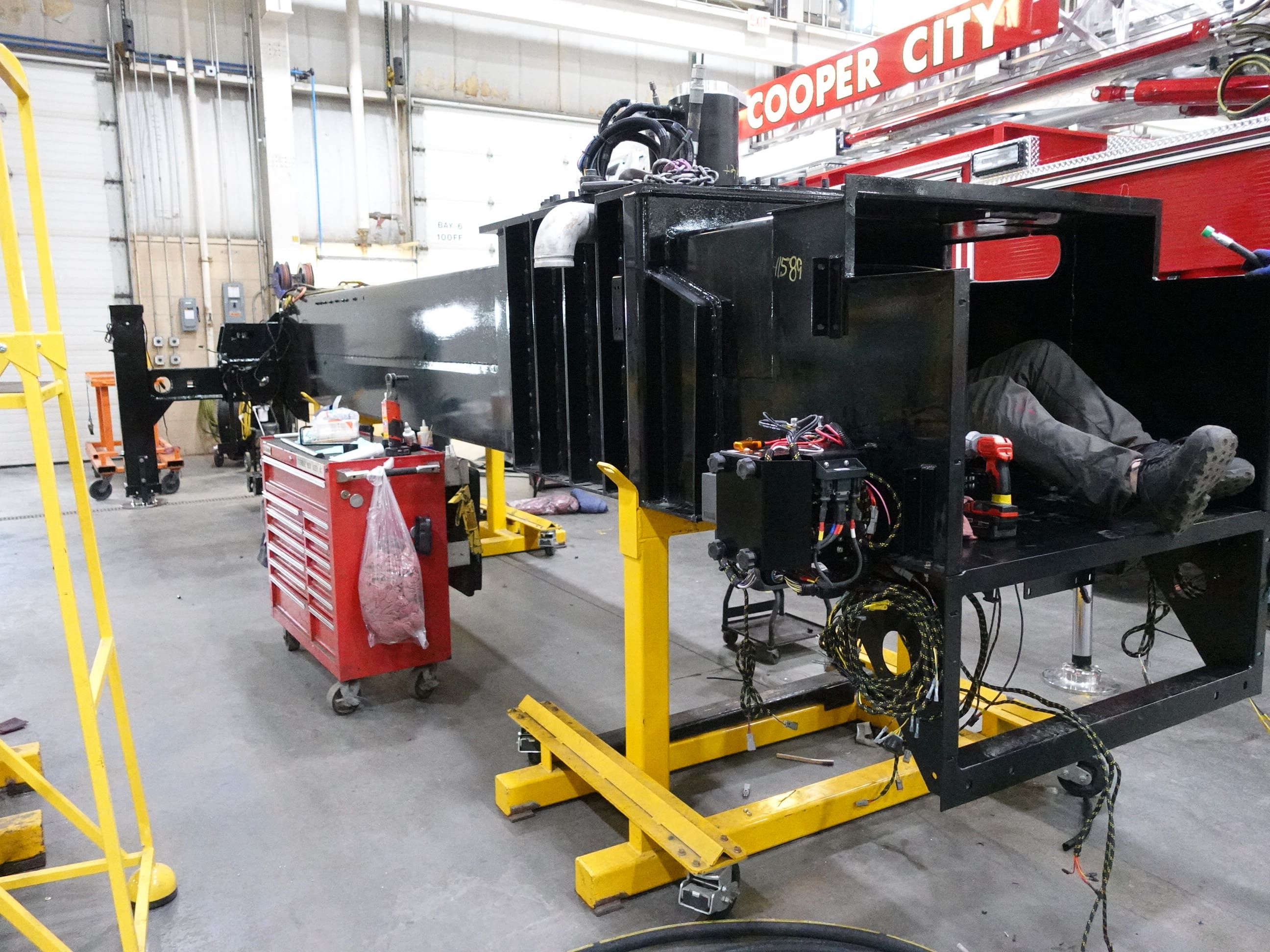

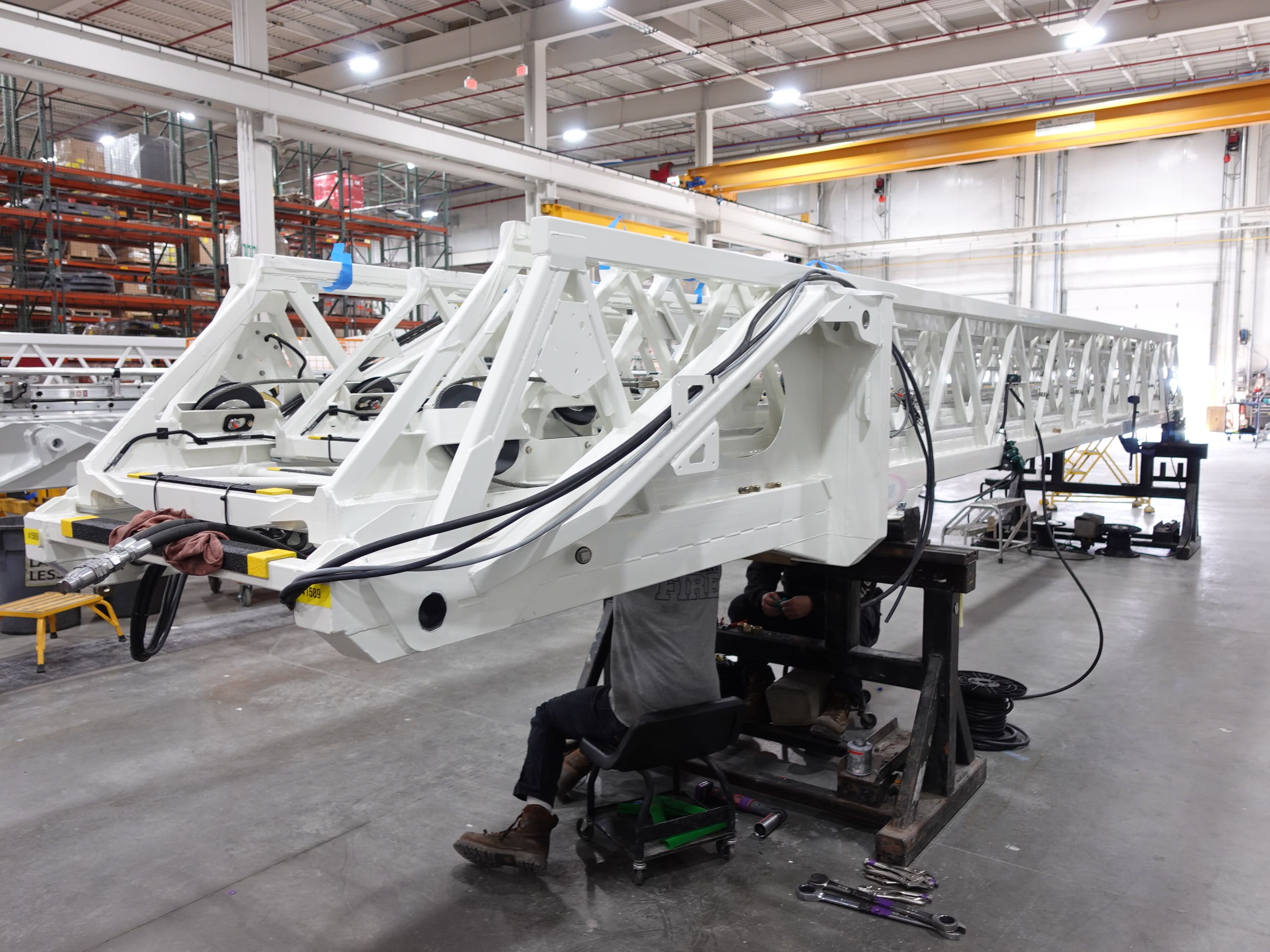

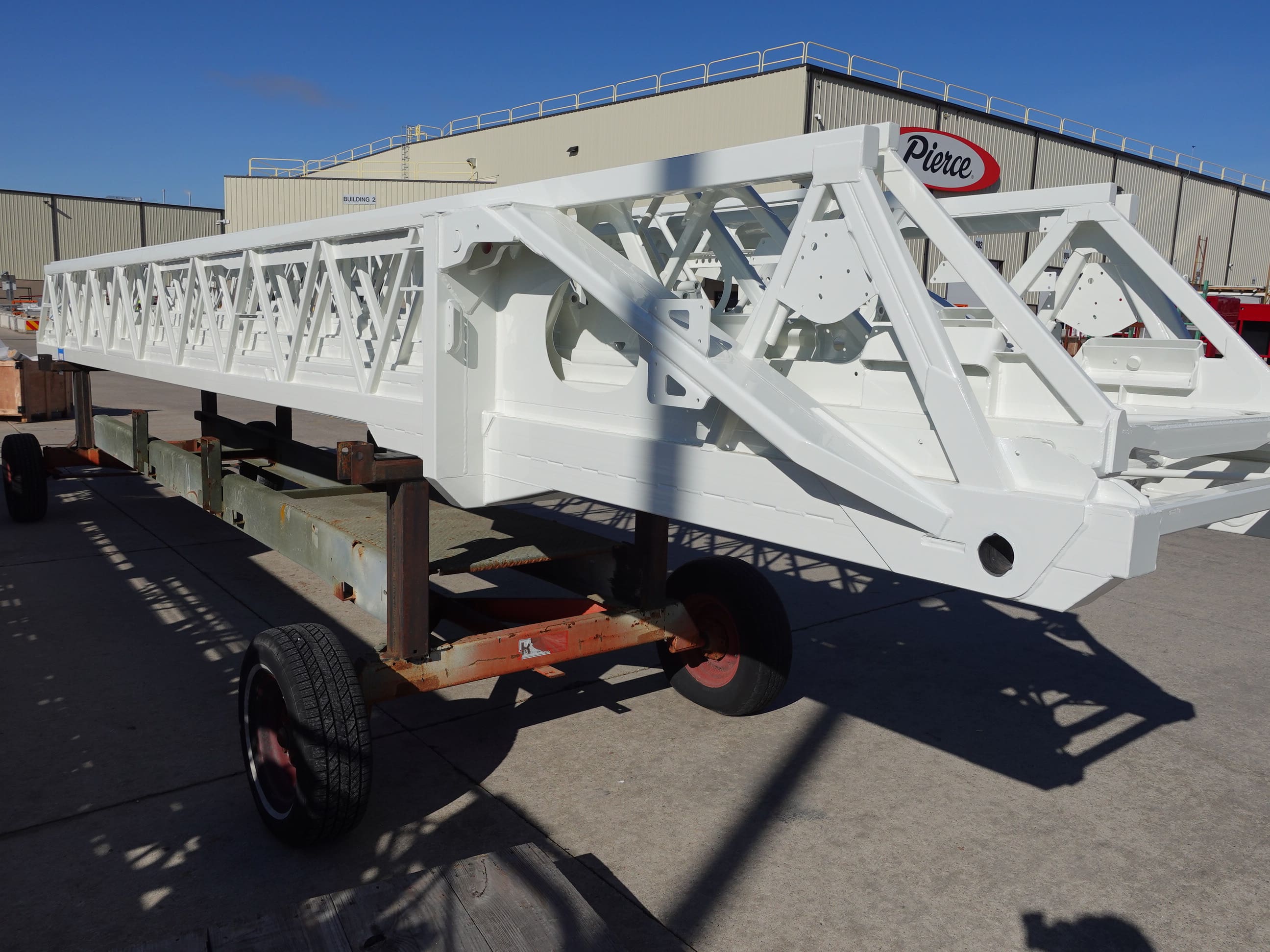

In this report, the body was merged with the chassis and your apparatus began final assembly while the aerial device began initial assembly.

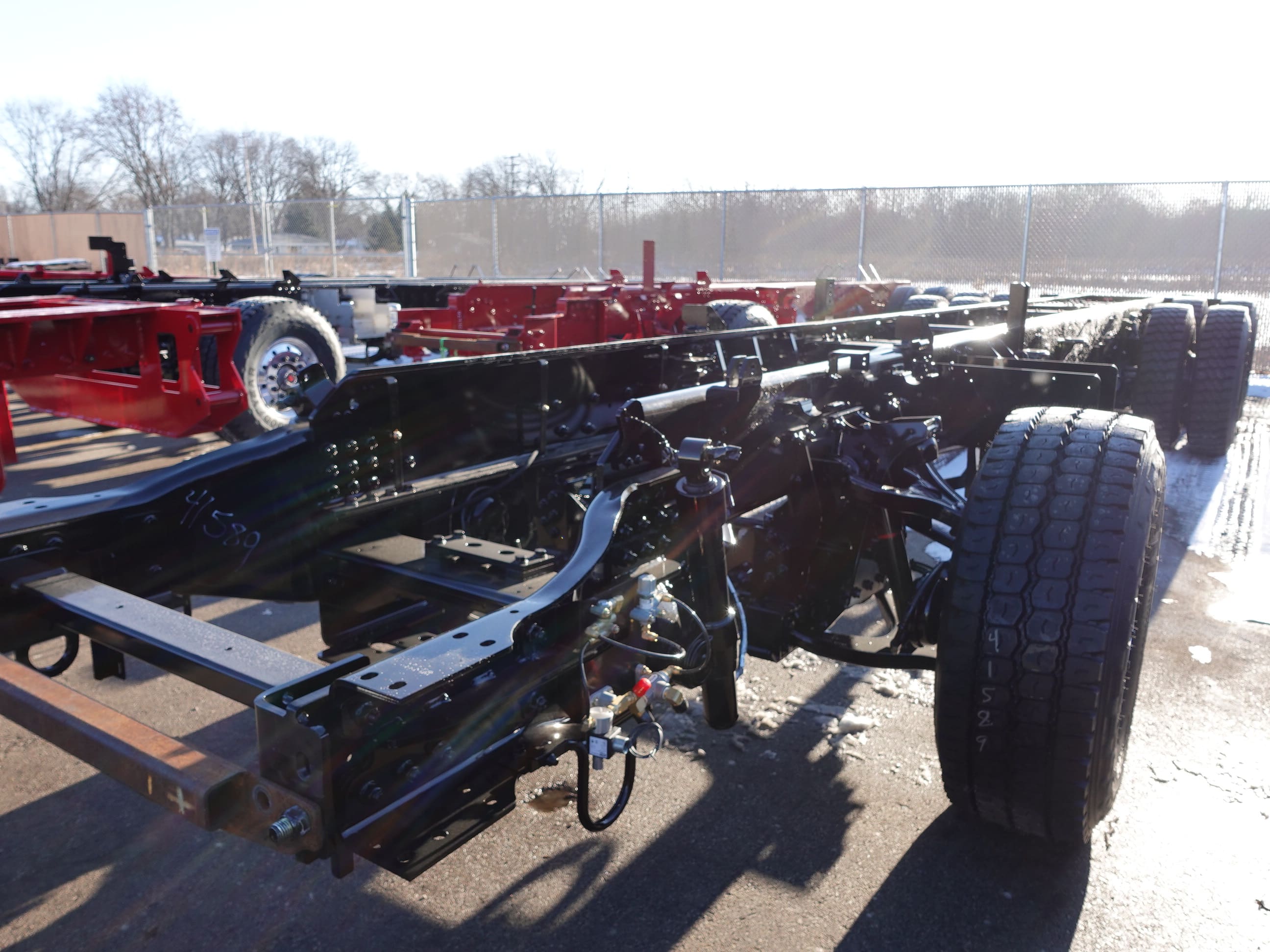

02-20-26

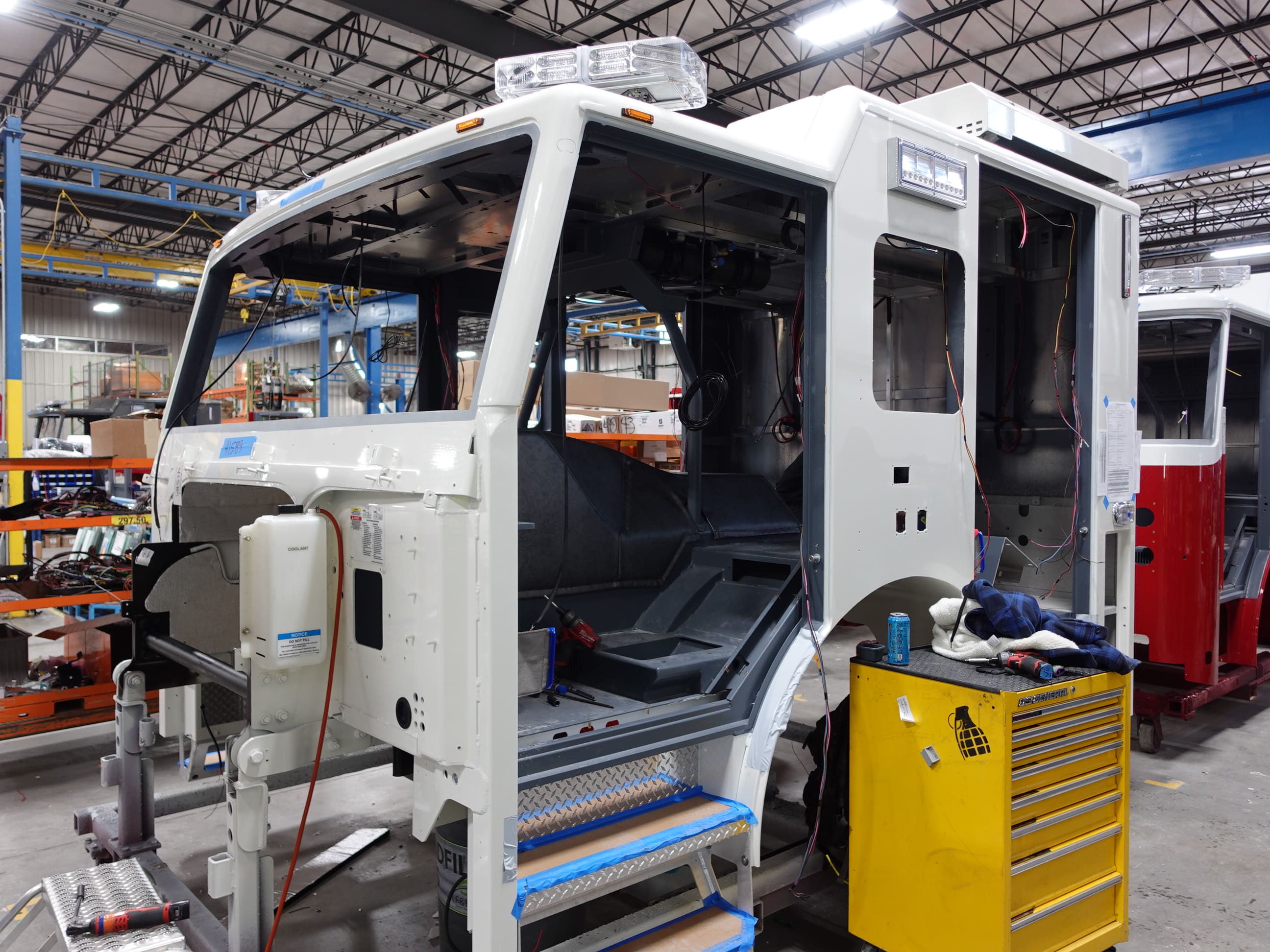

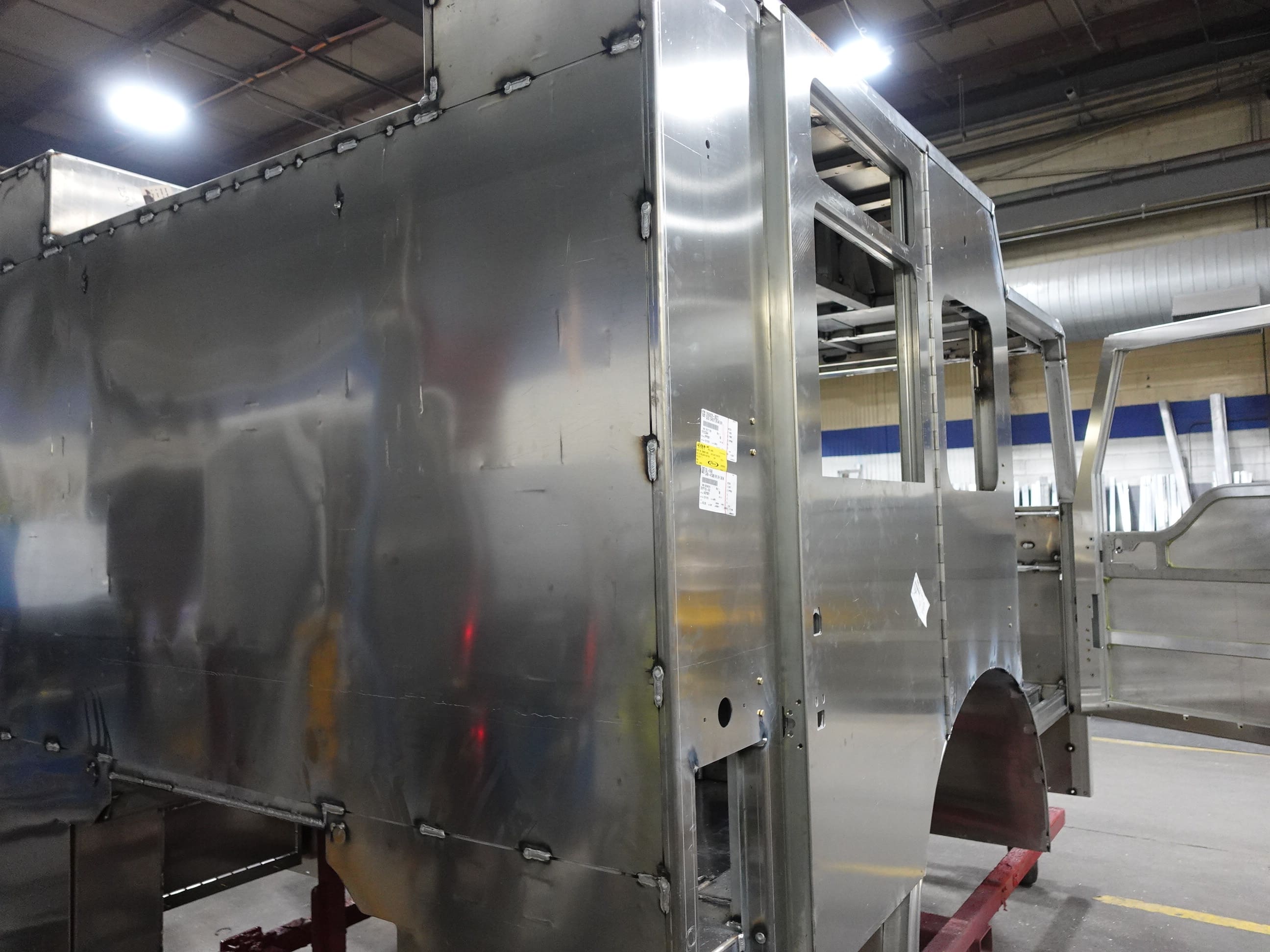

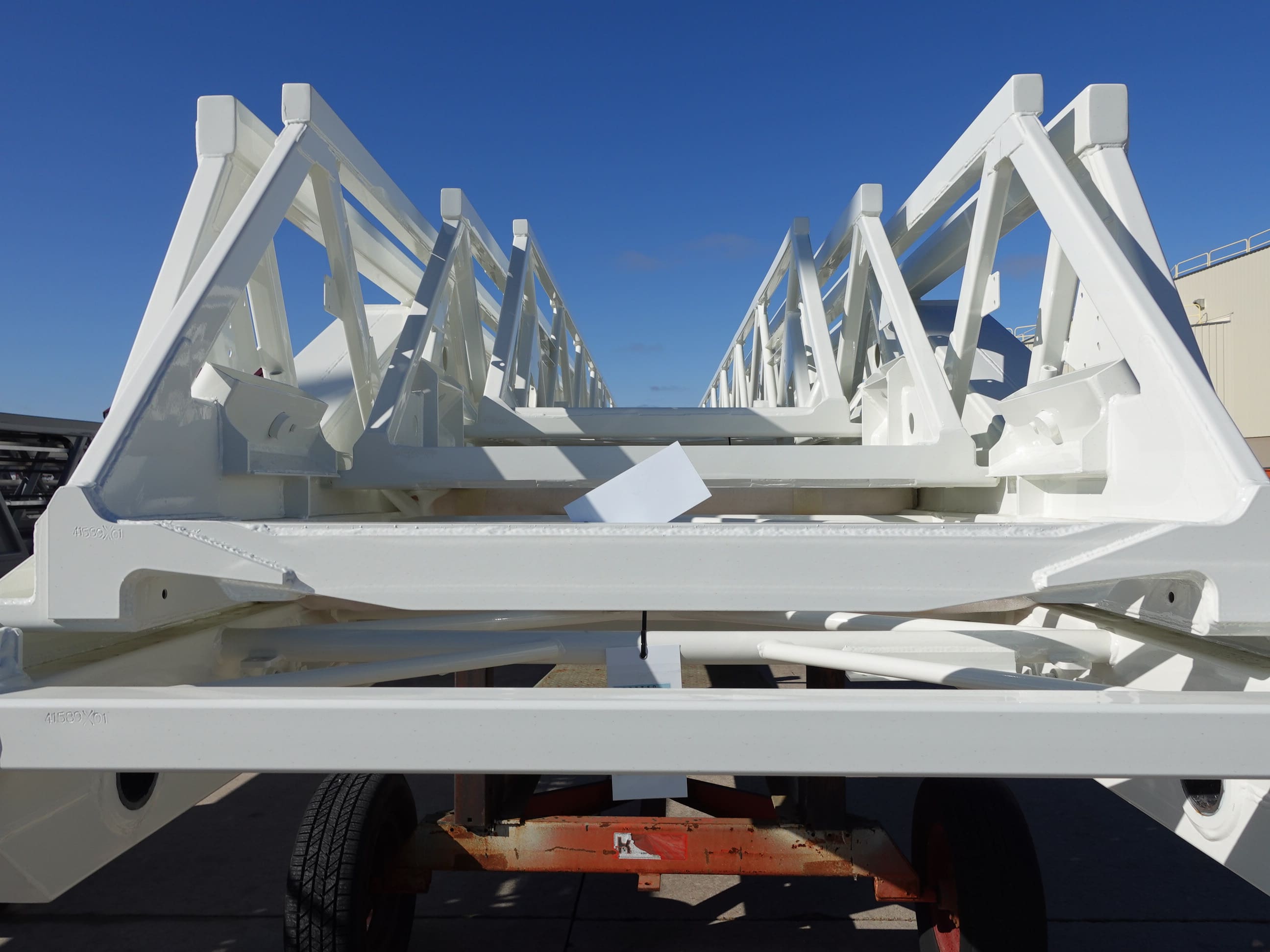

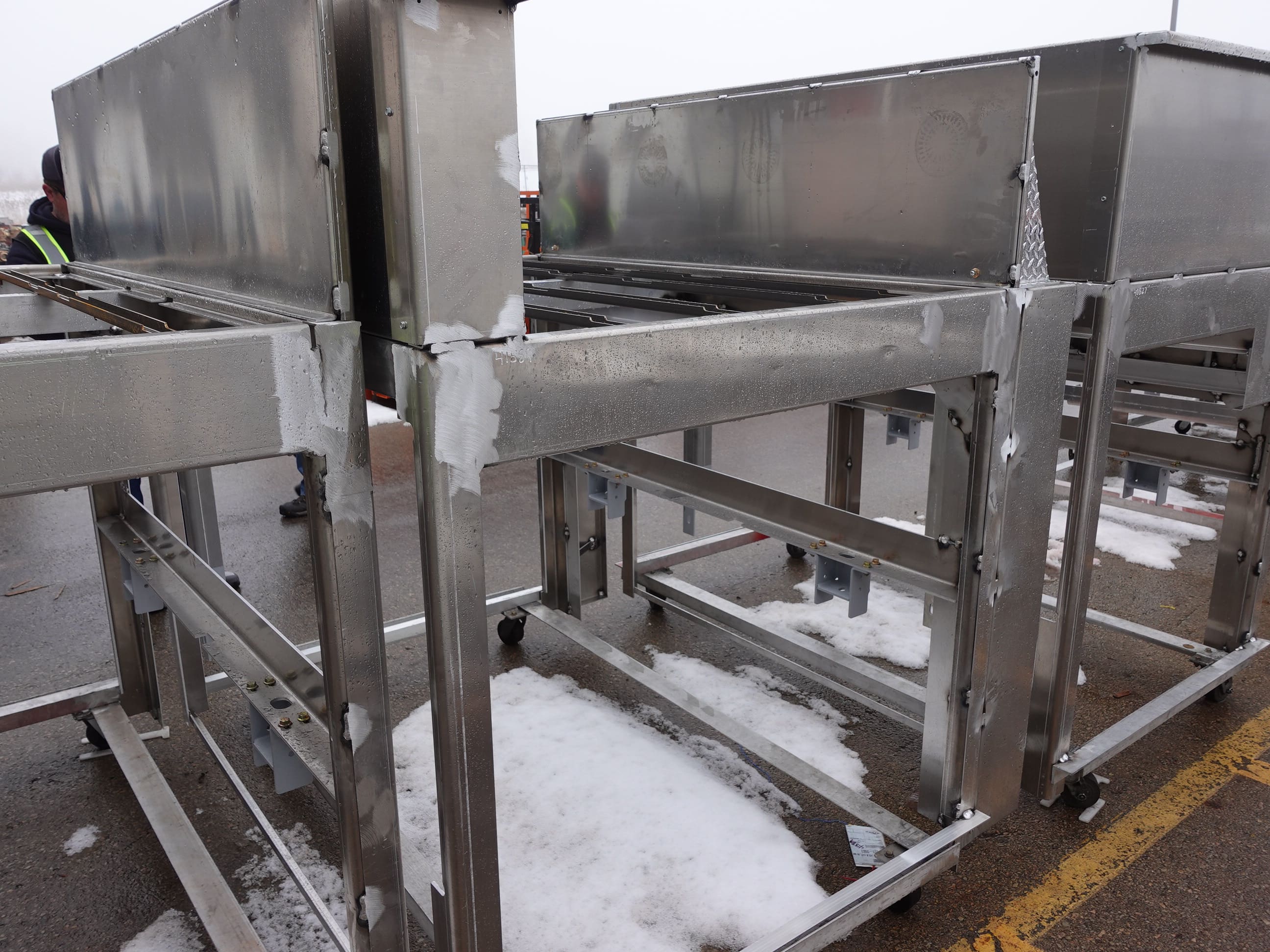

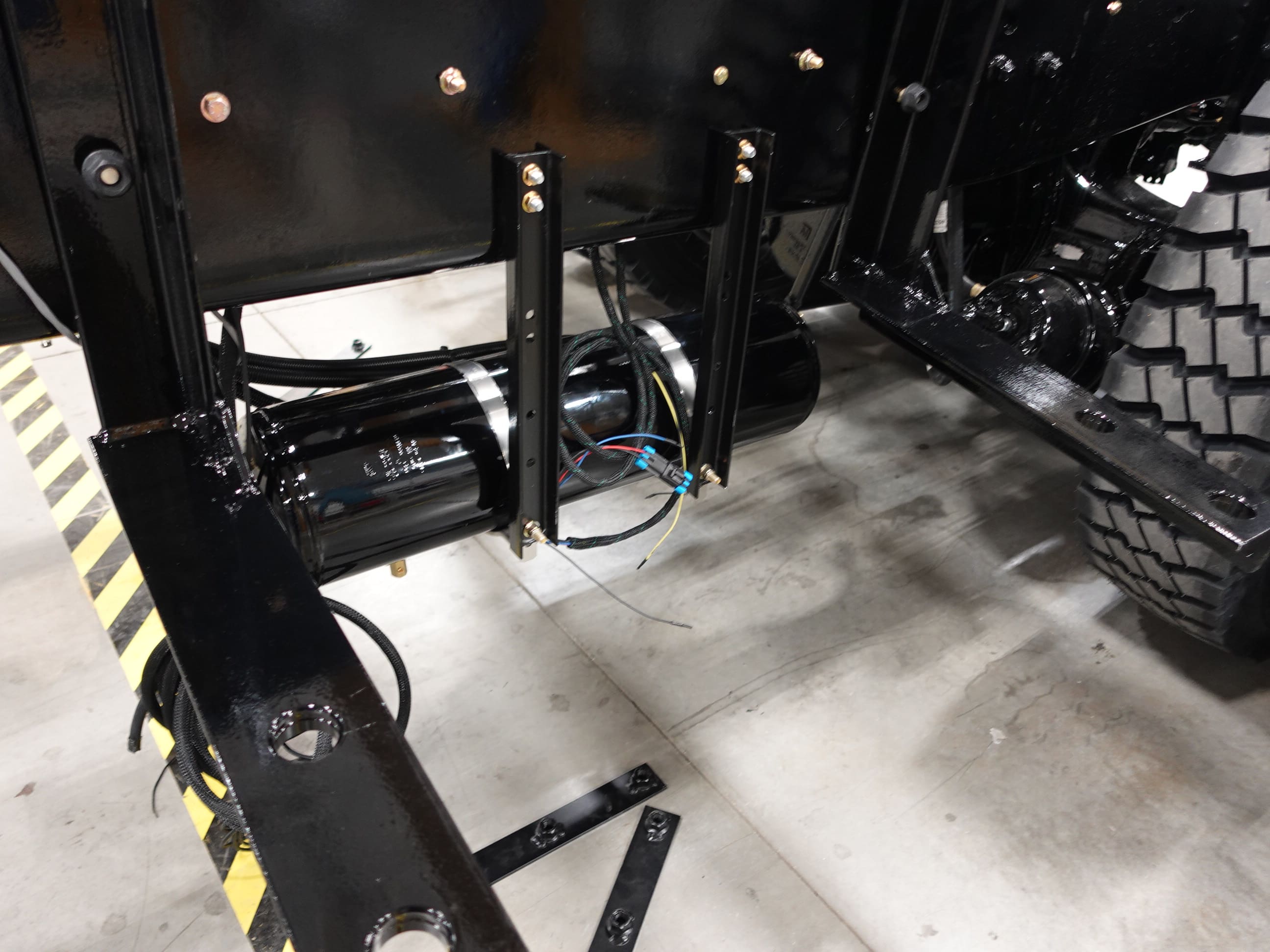

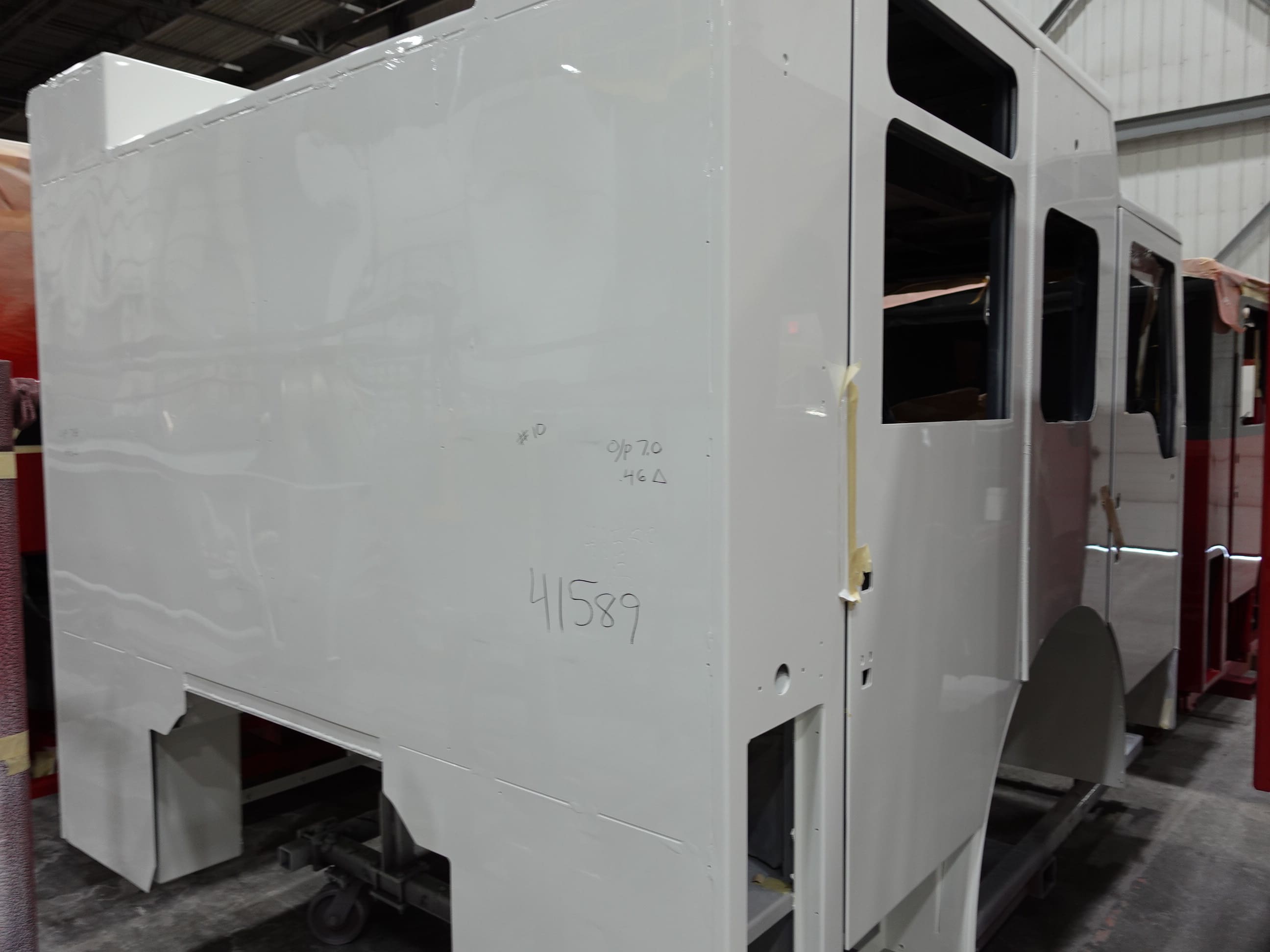

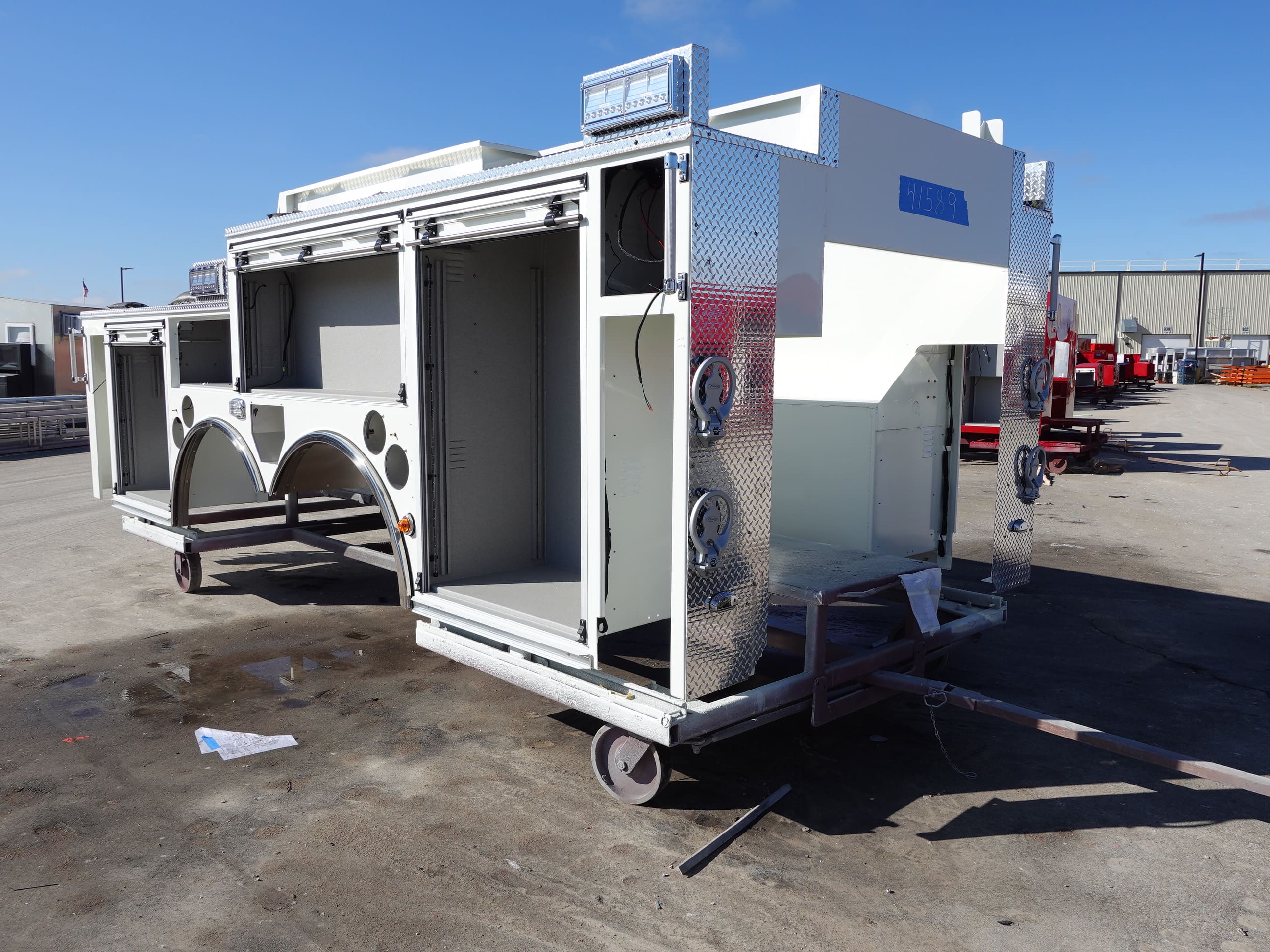

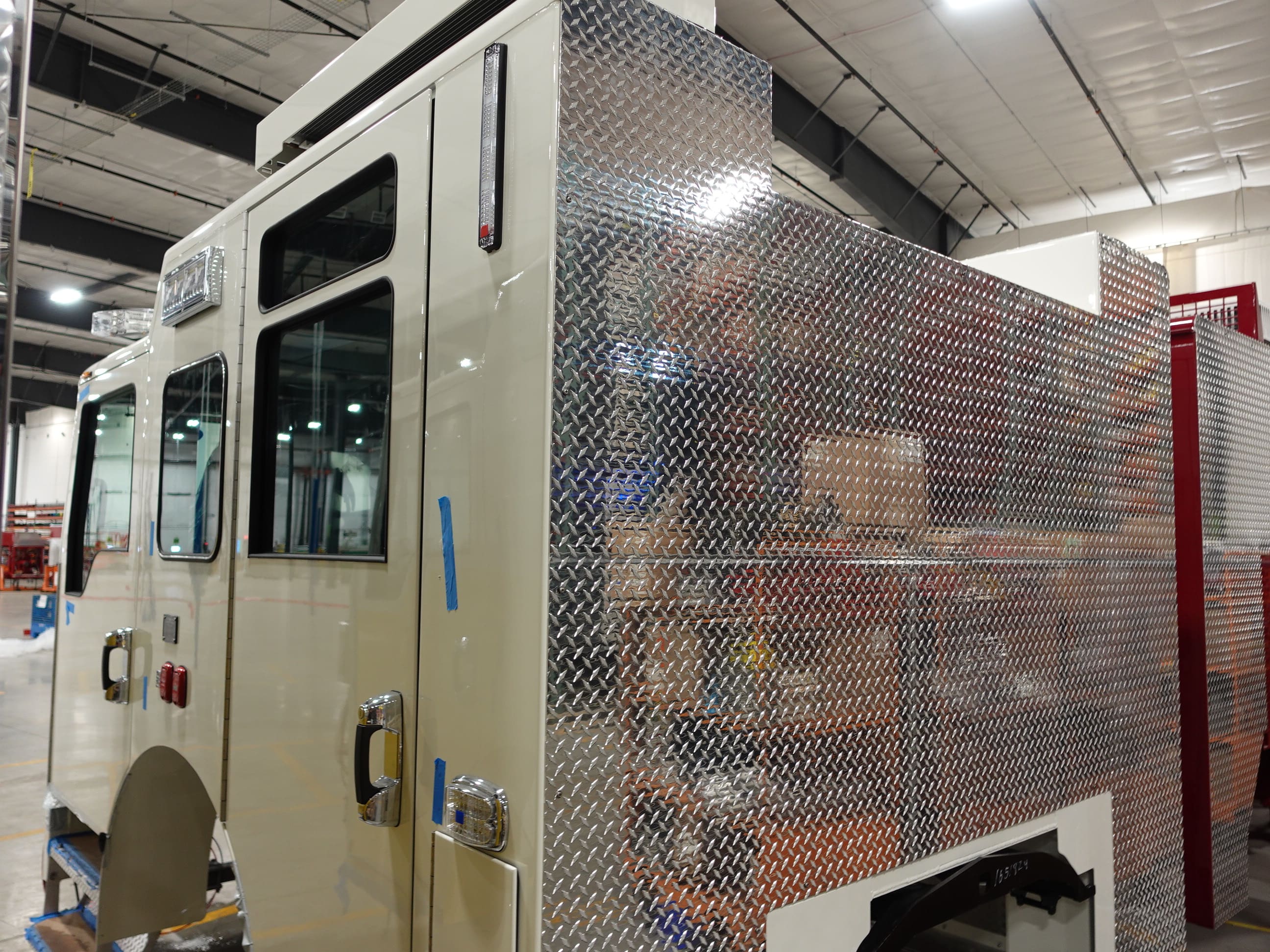

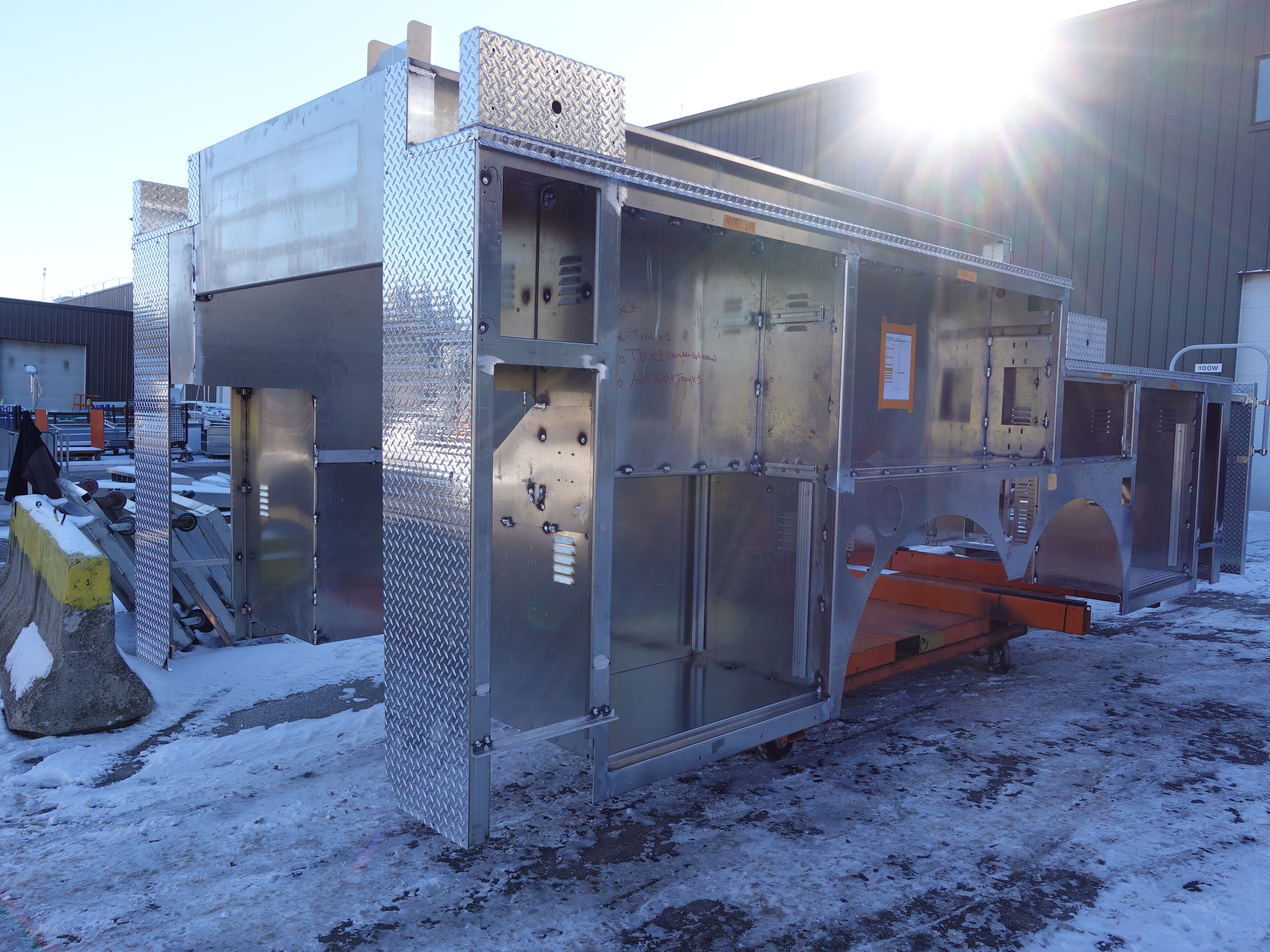

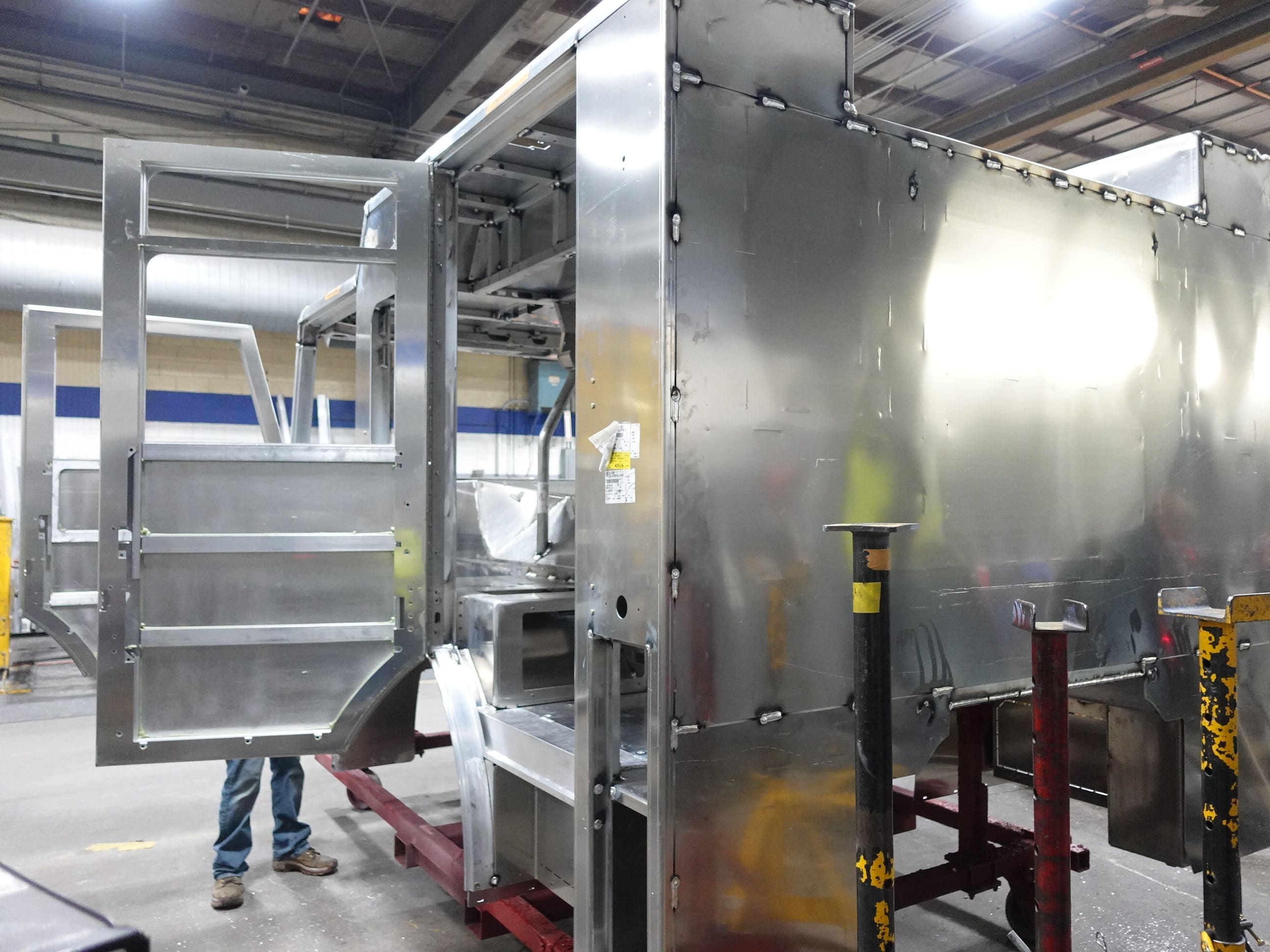

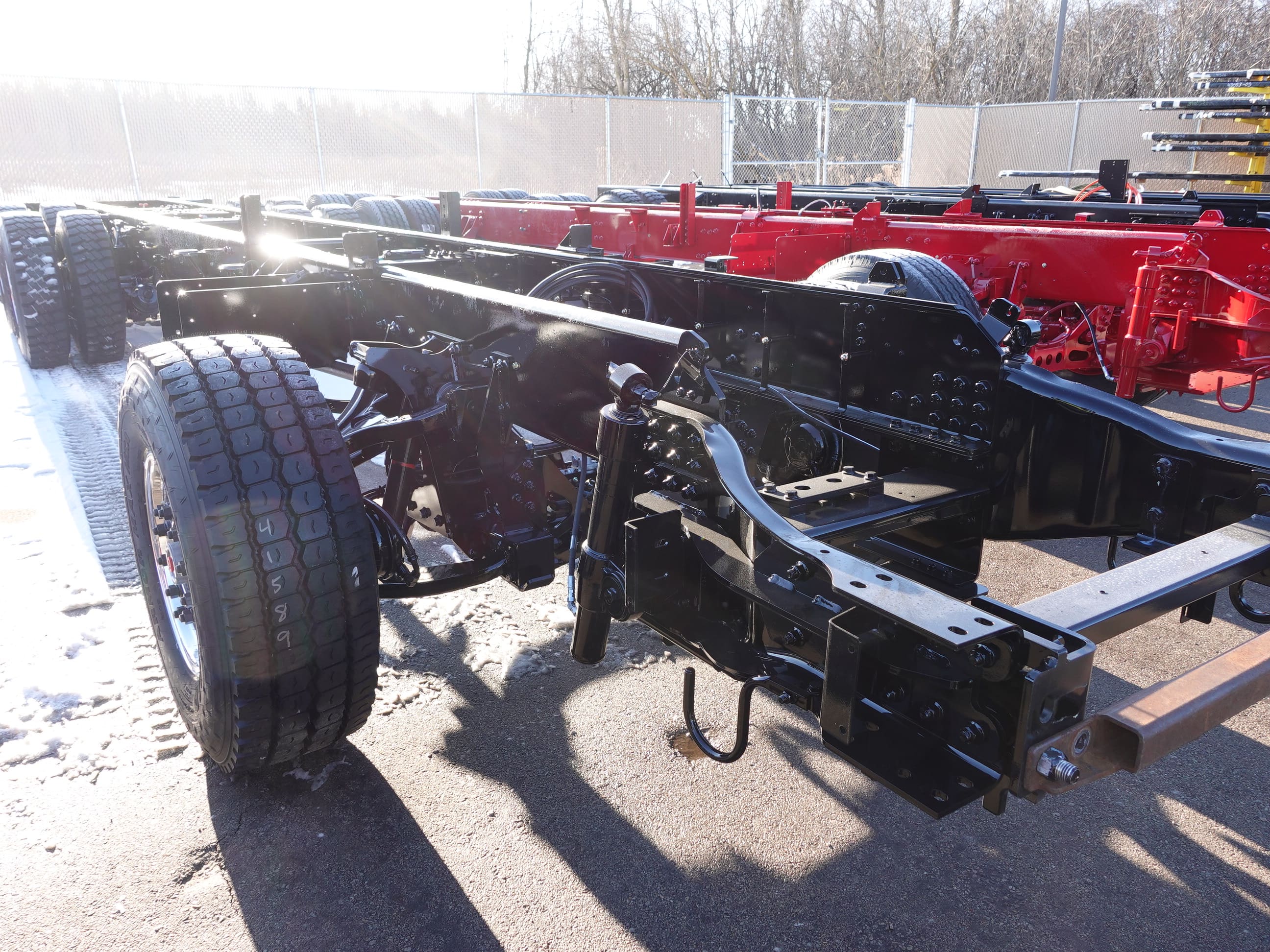

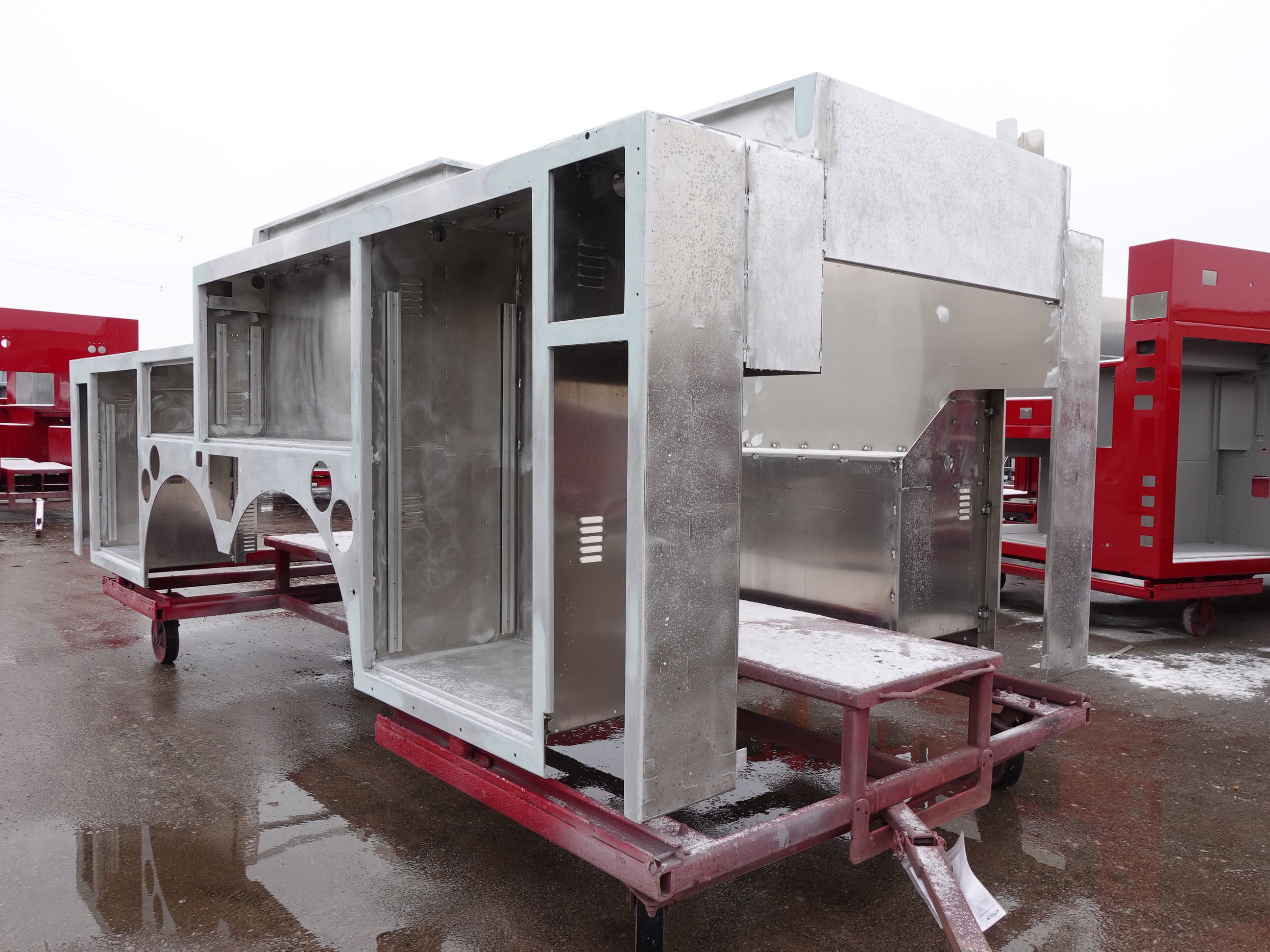

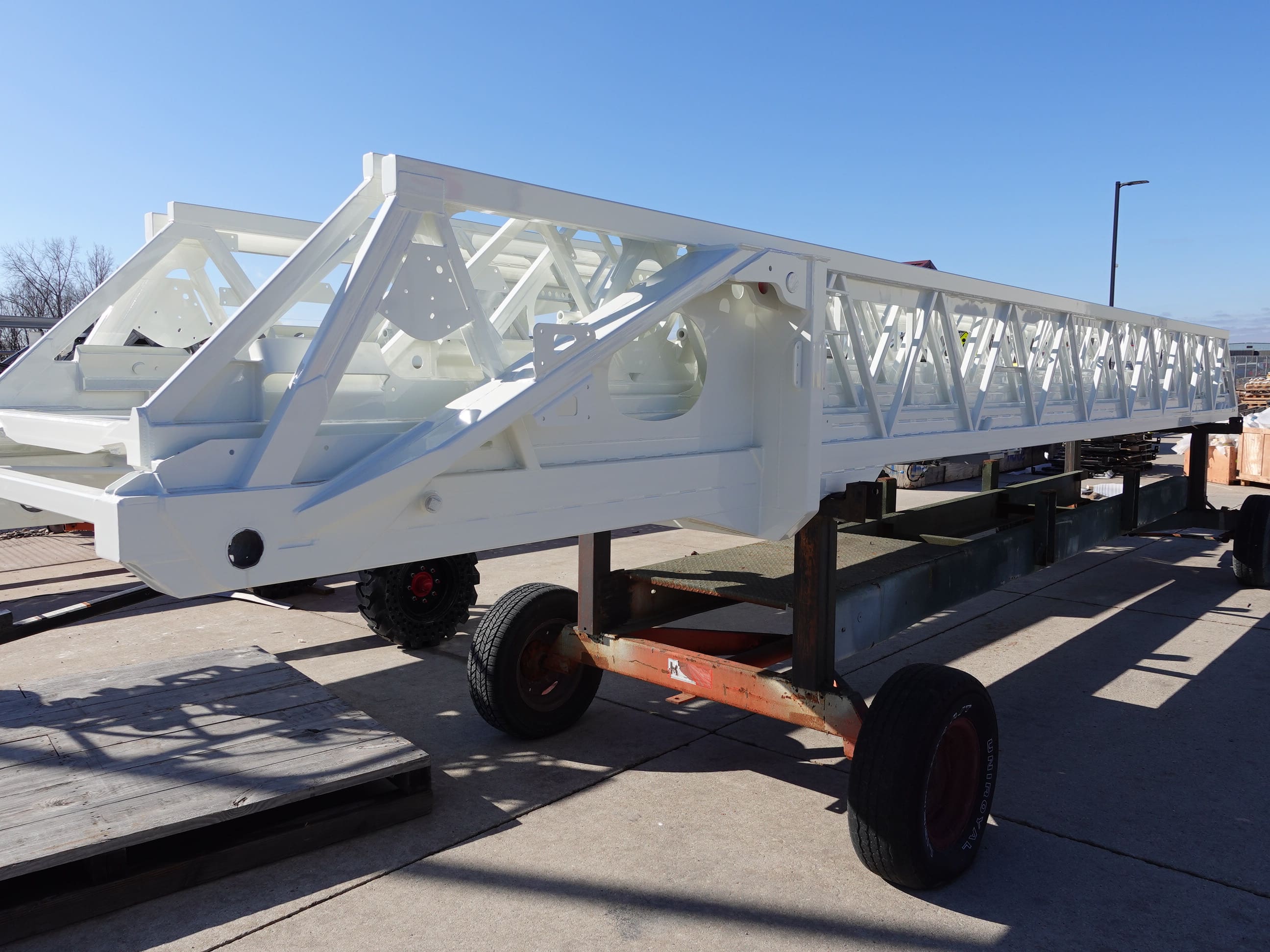

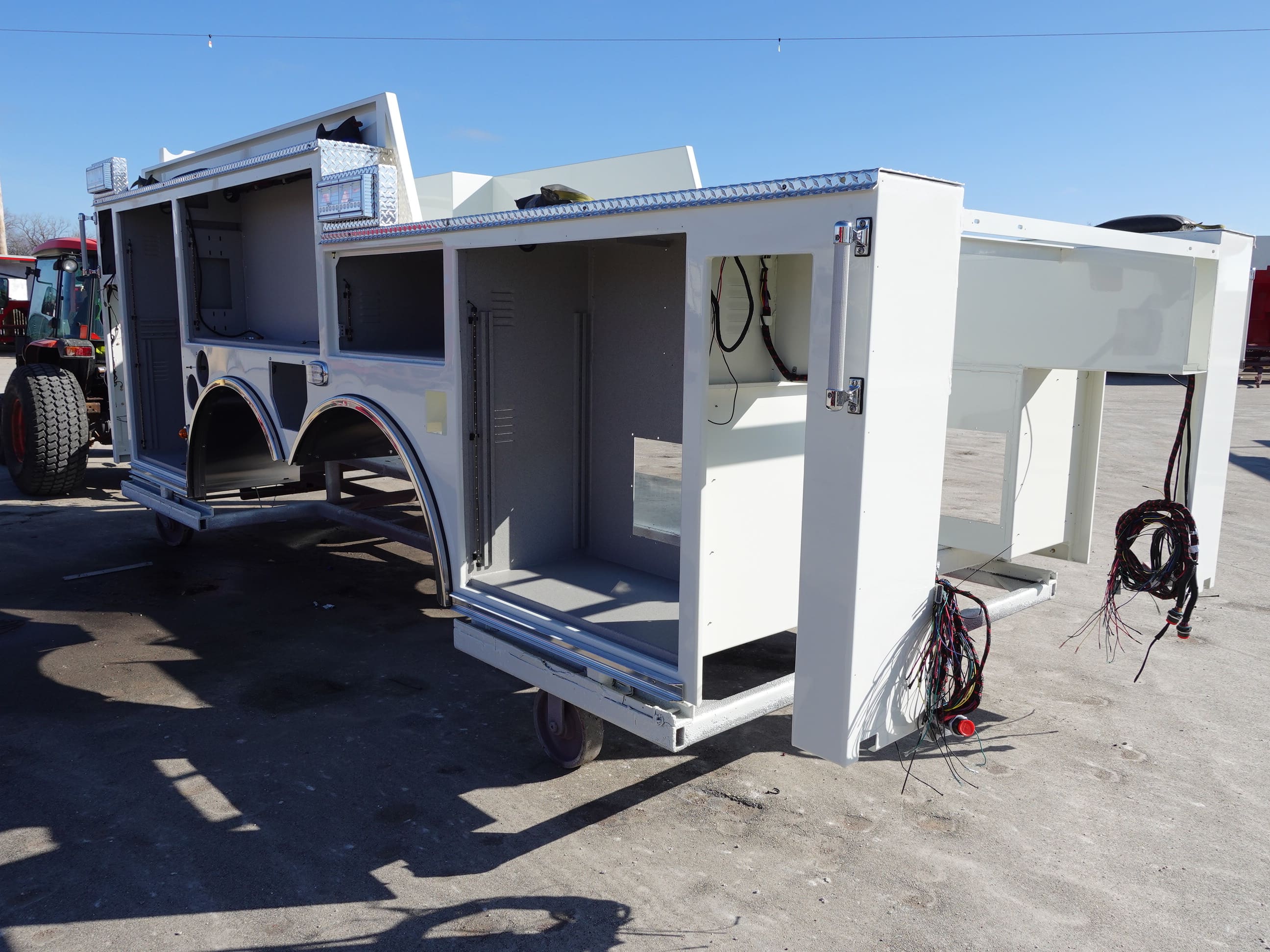

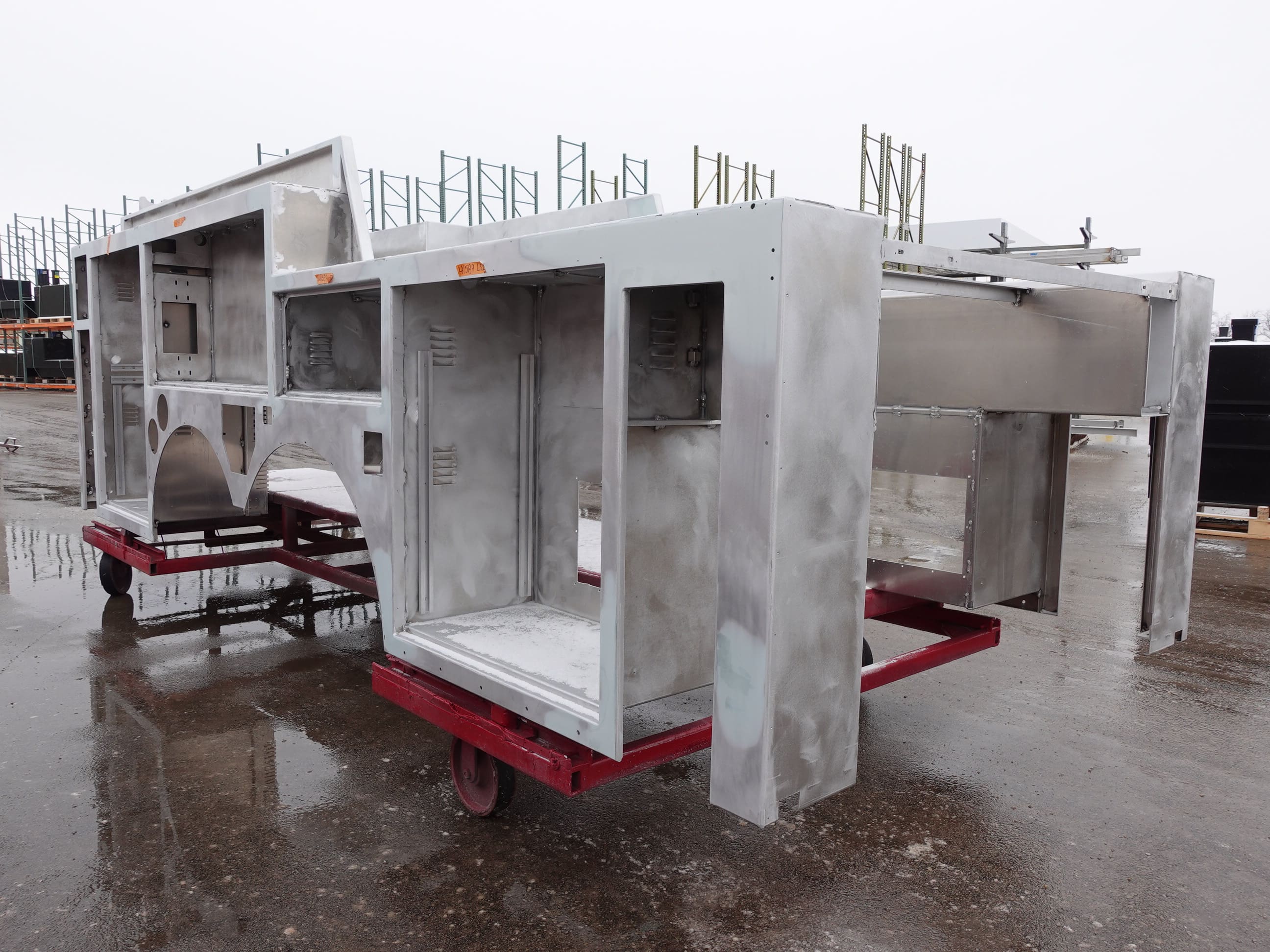

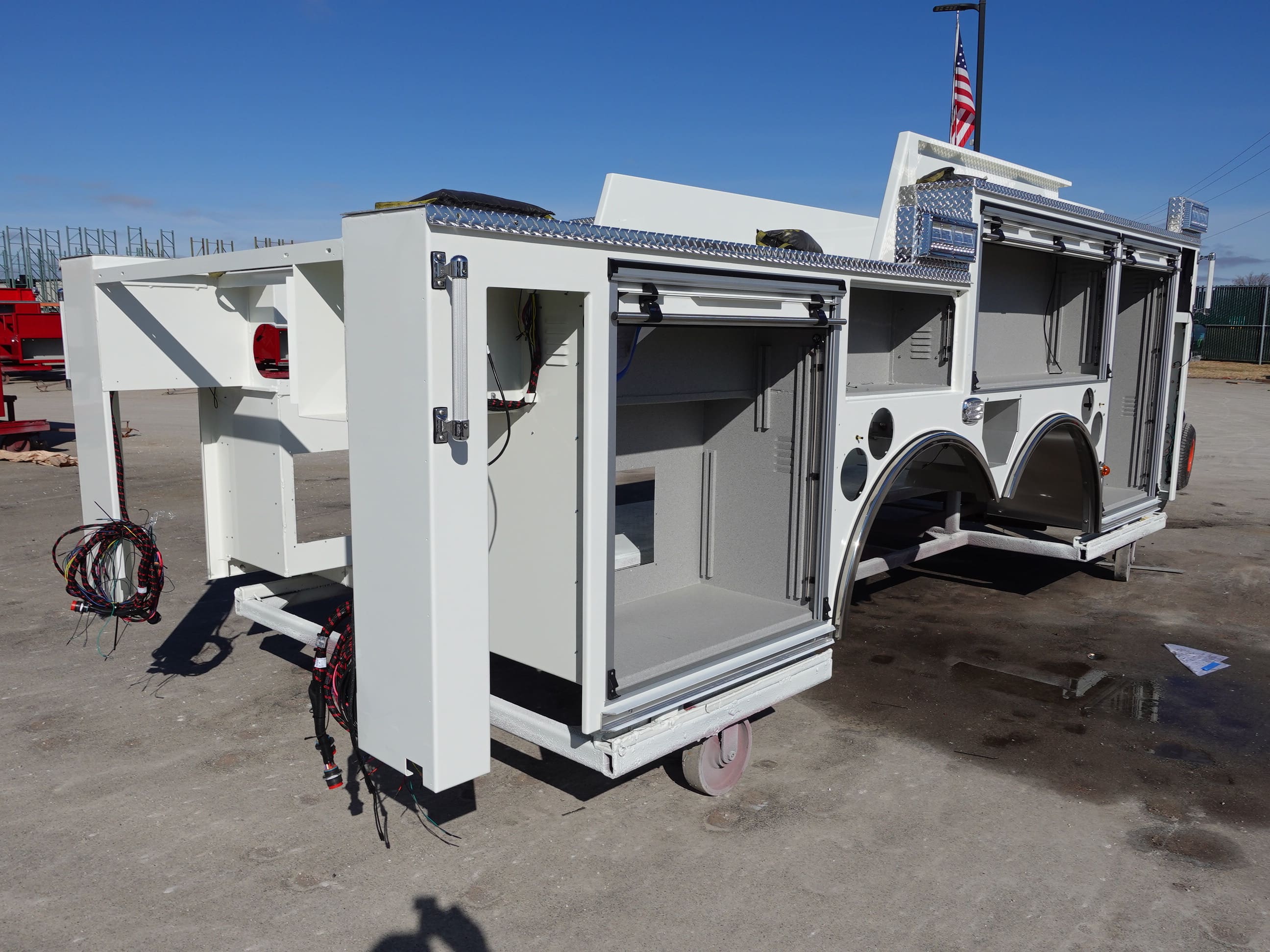

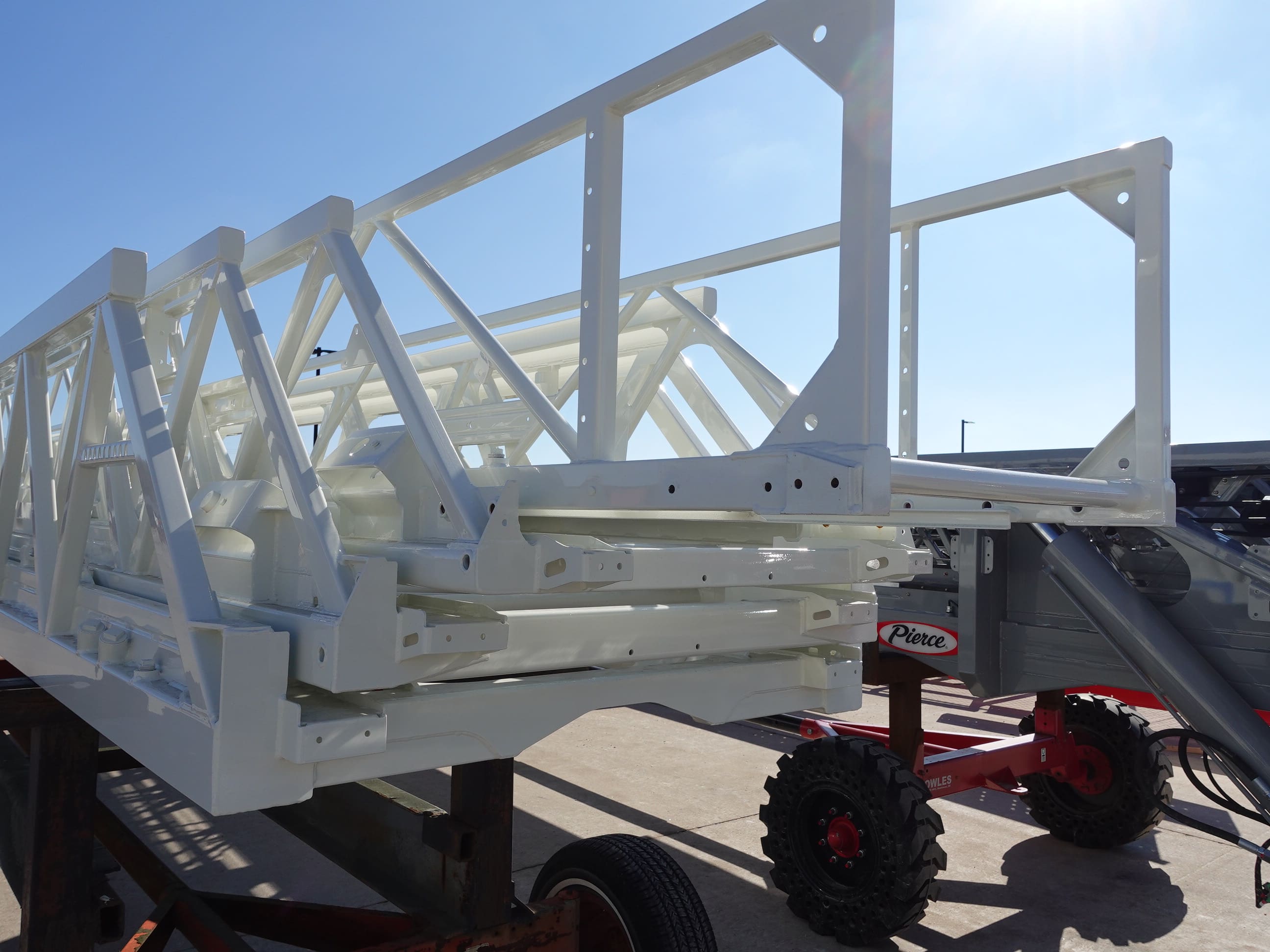

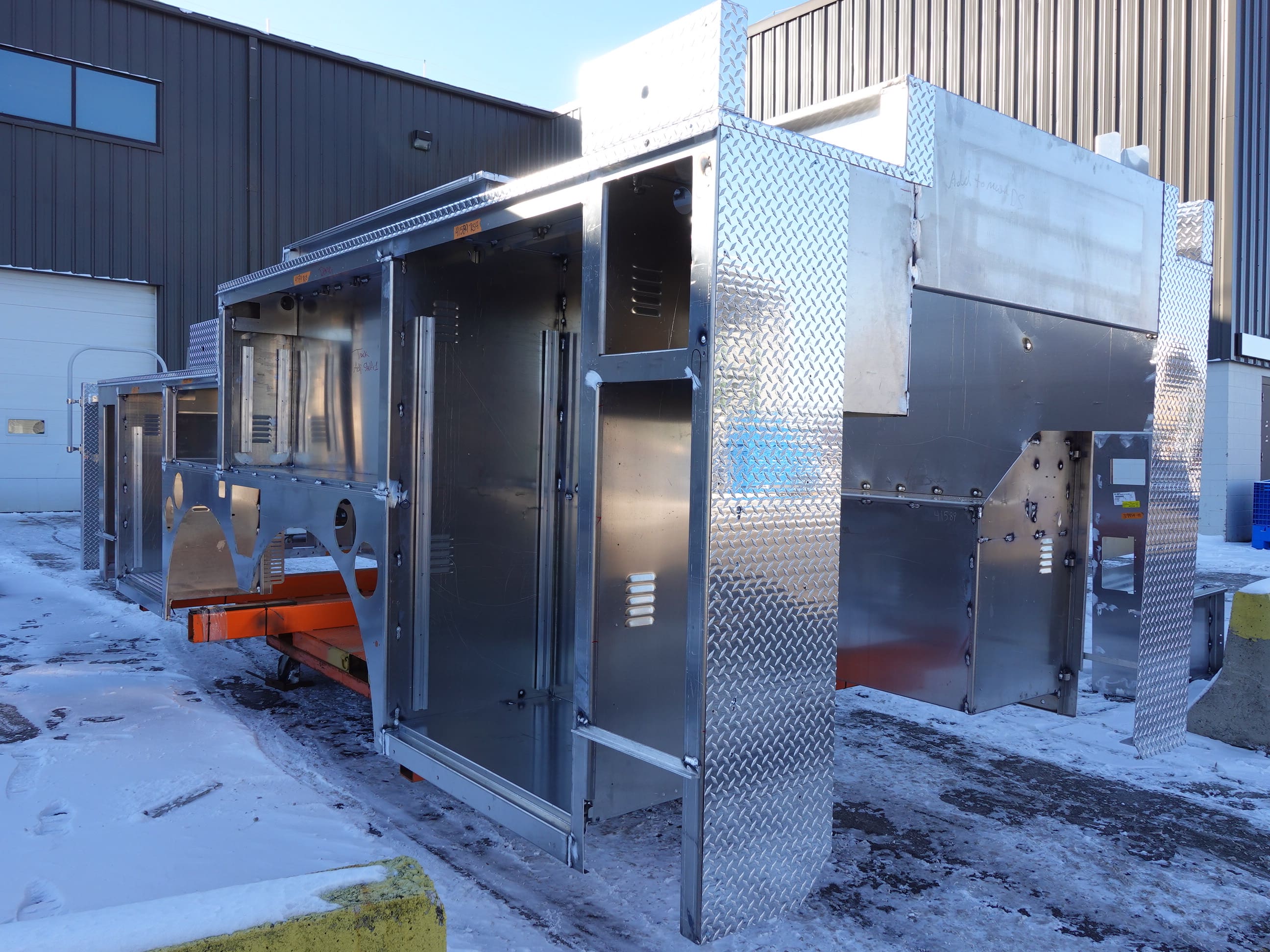

In this report, the torque box was merged with the chassis while the body completed initial assembly, and the aerial device arrived and was staged.

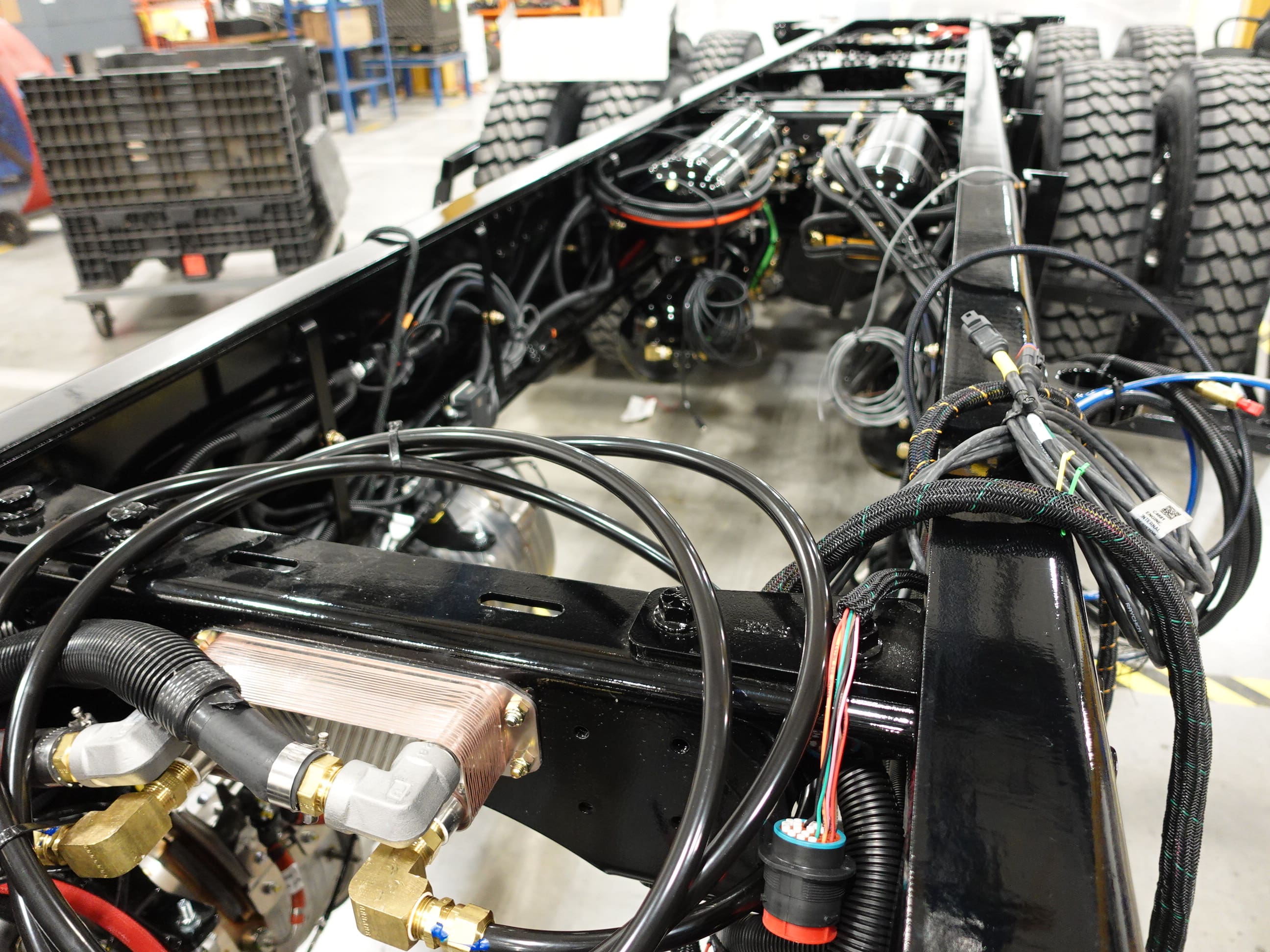

02-13-26

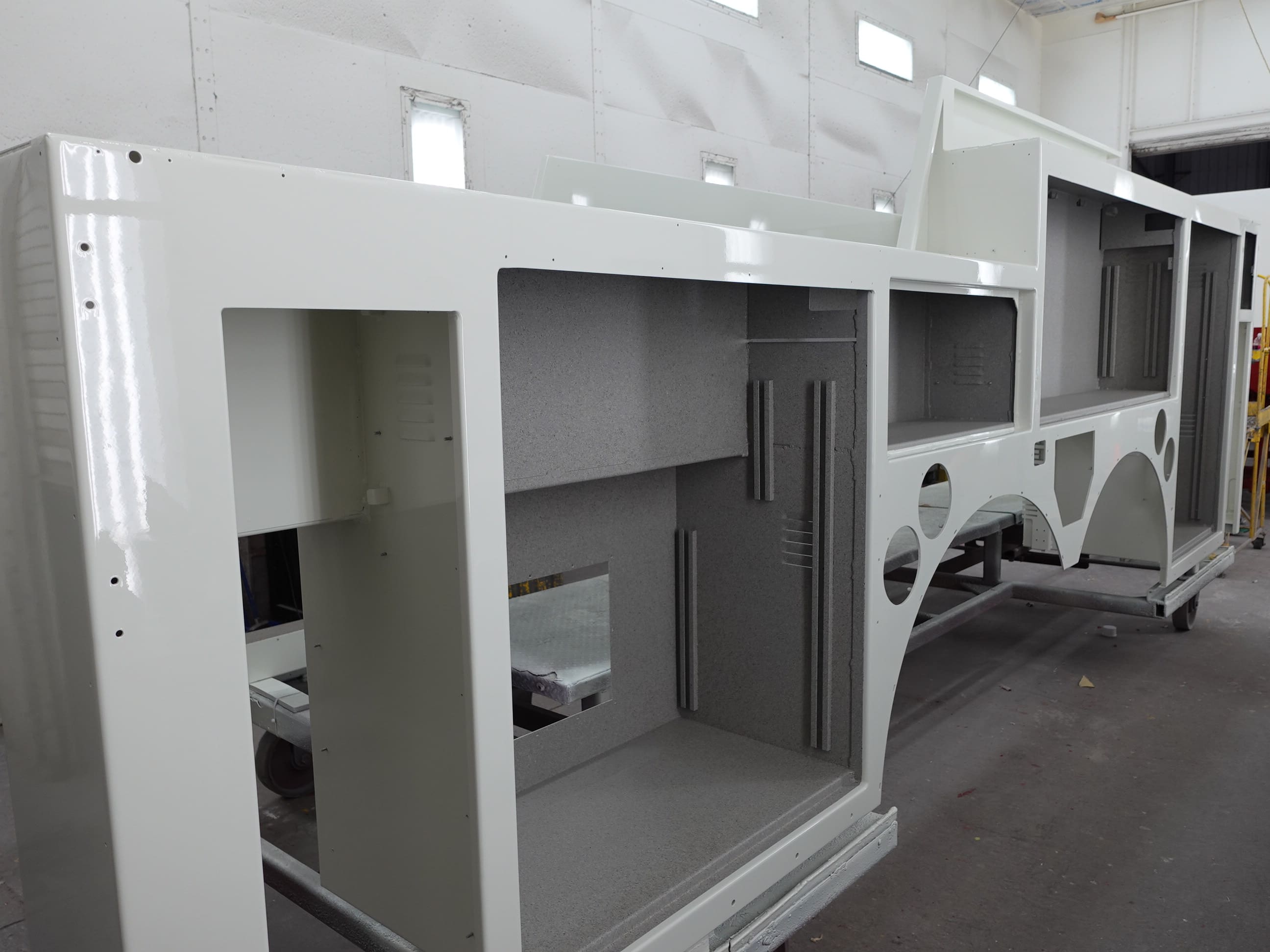

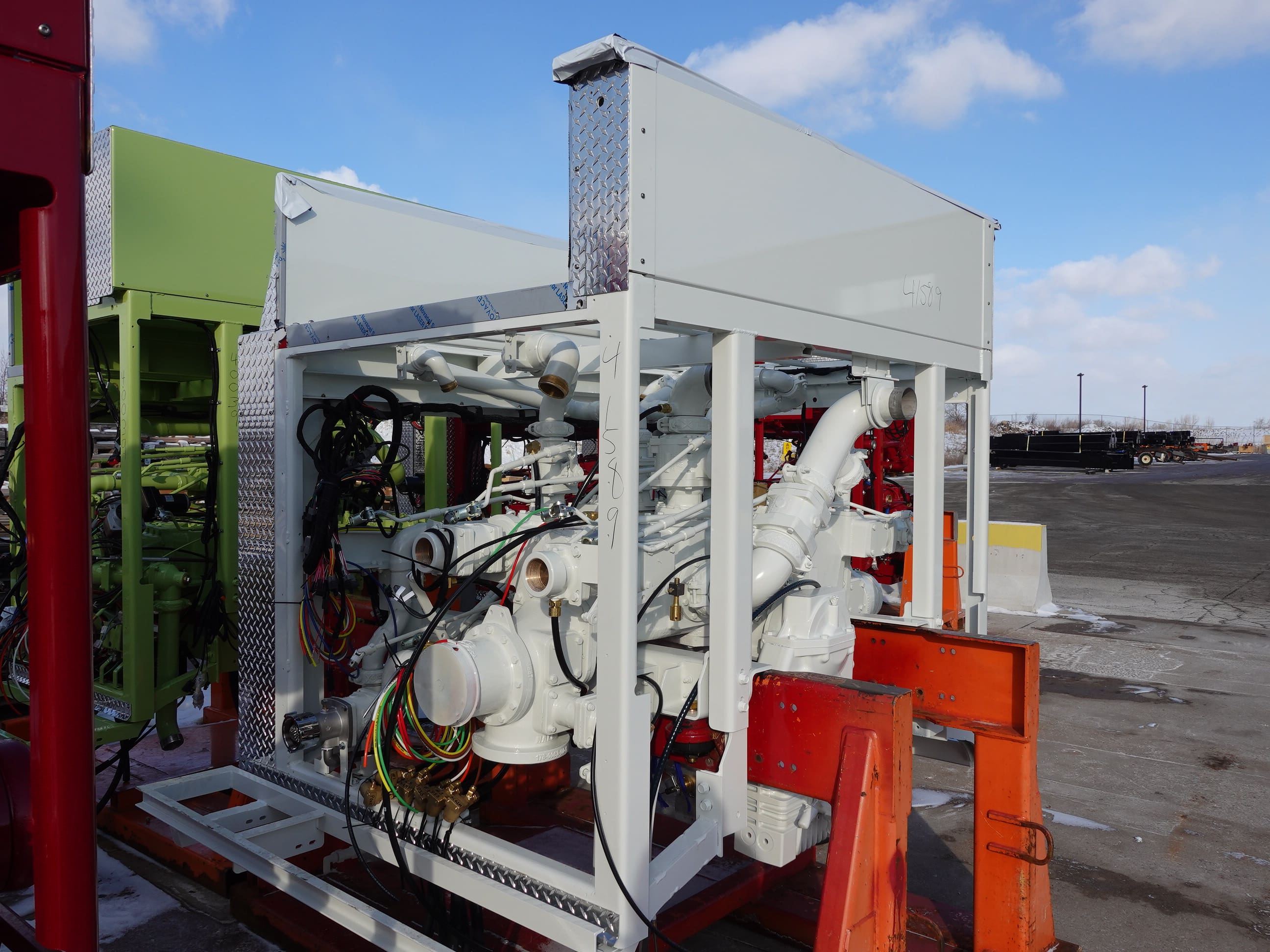

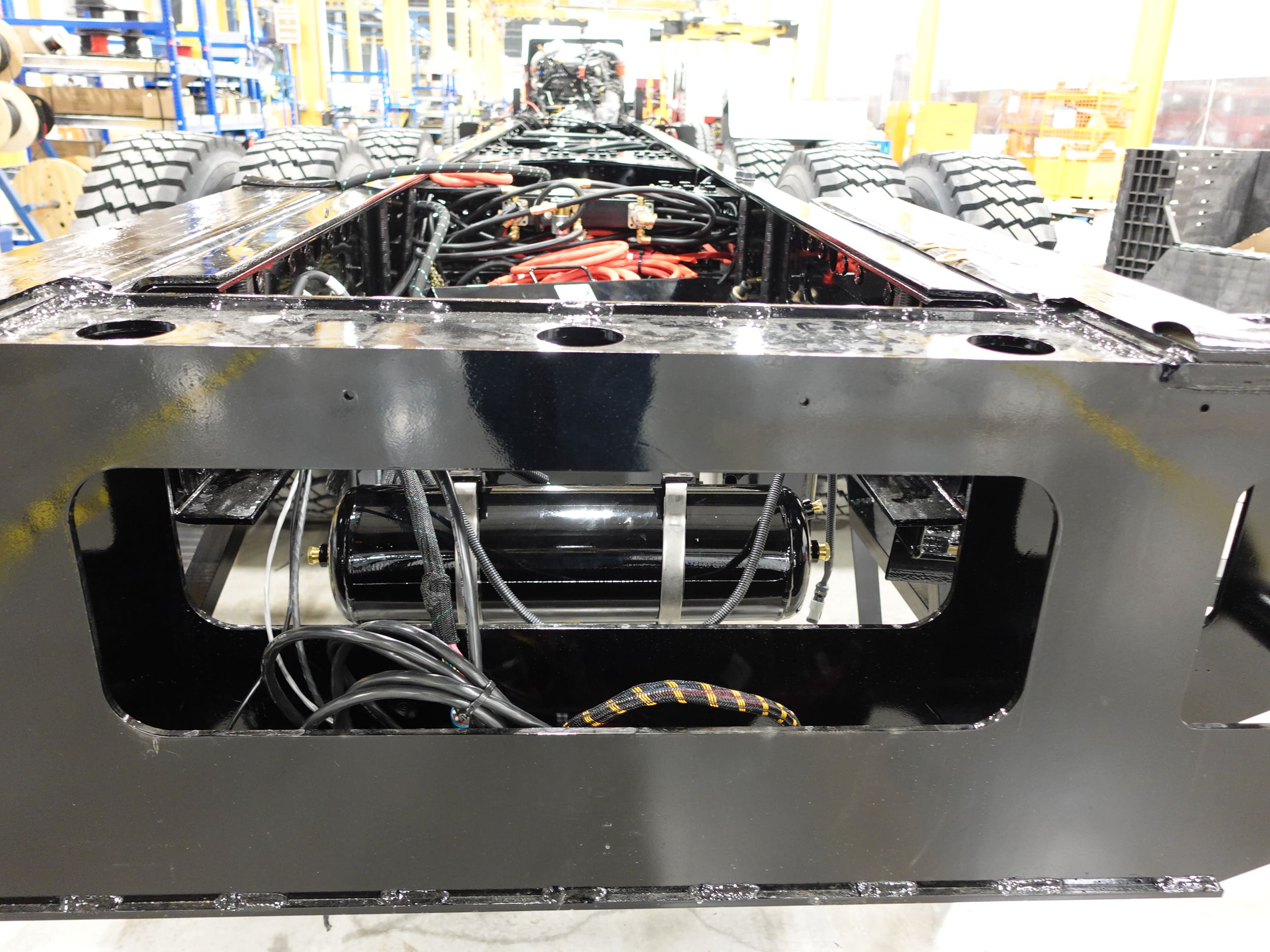

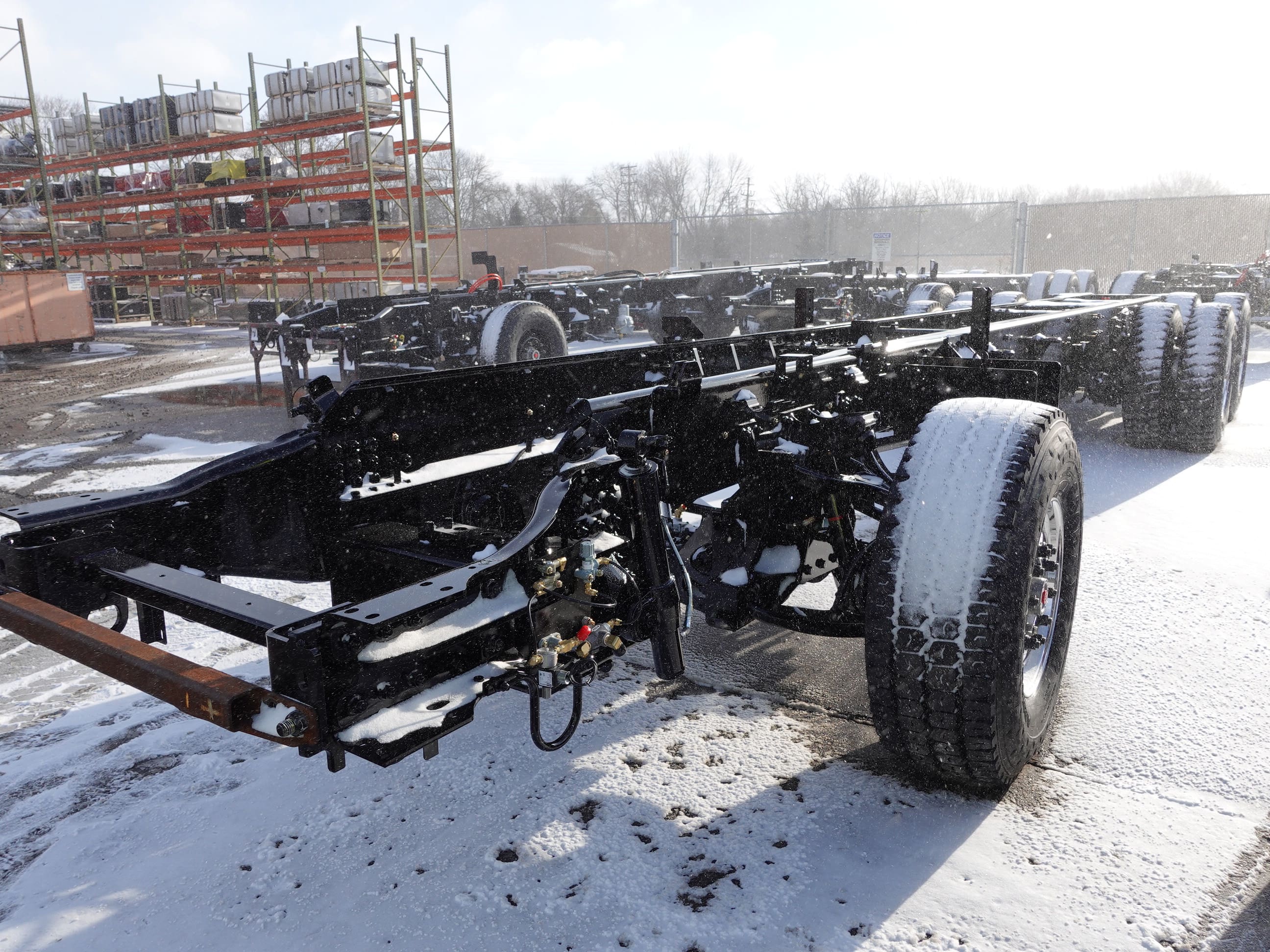

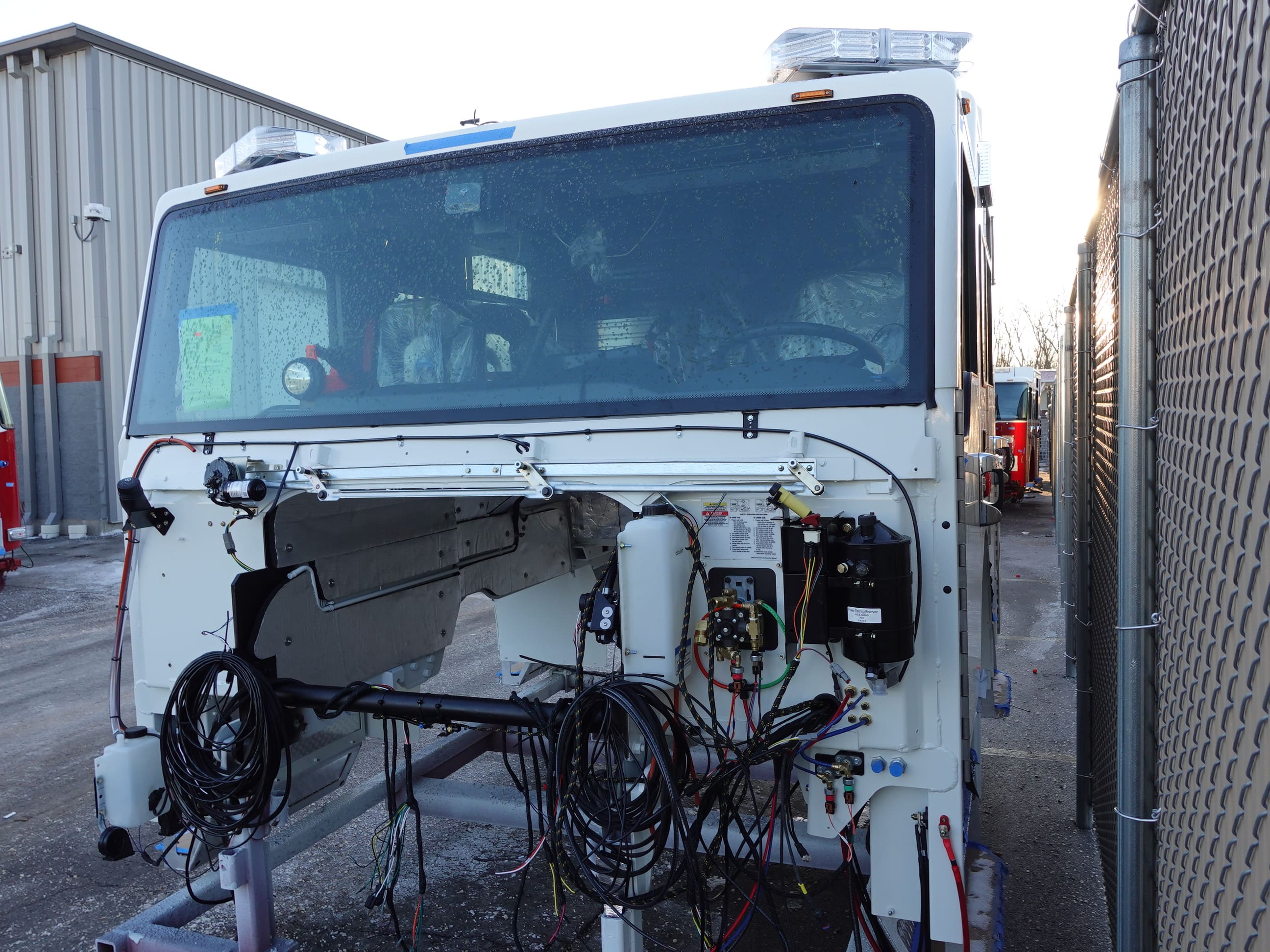

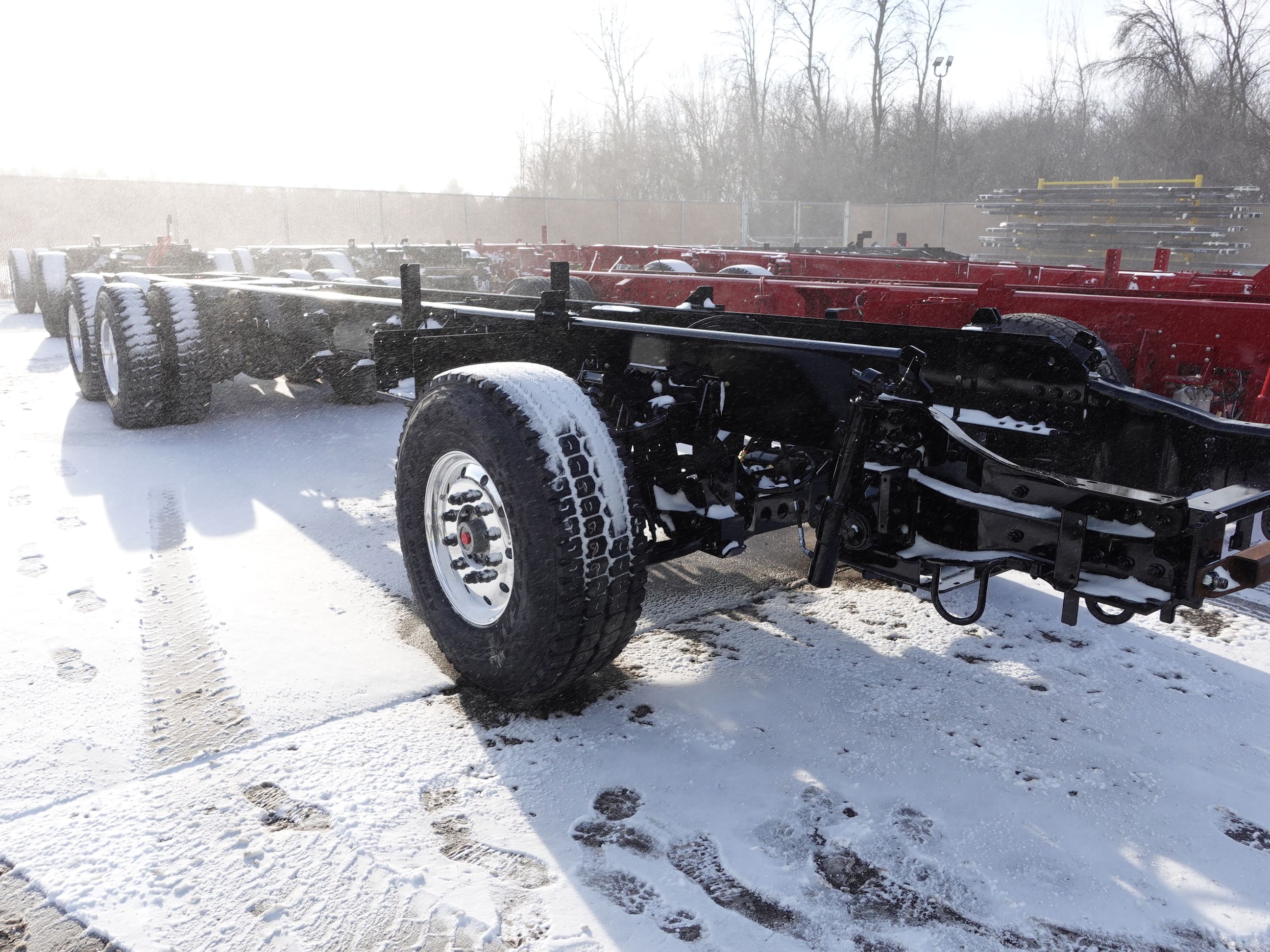

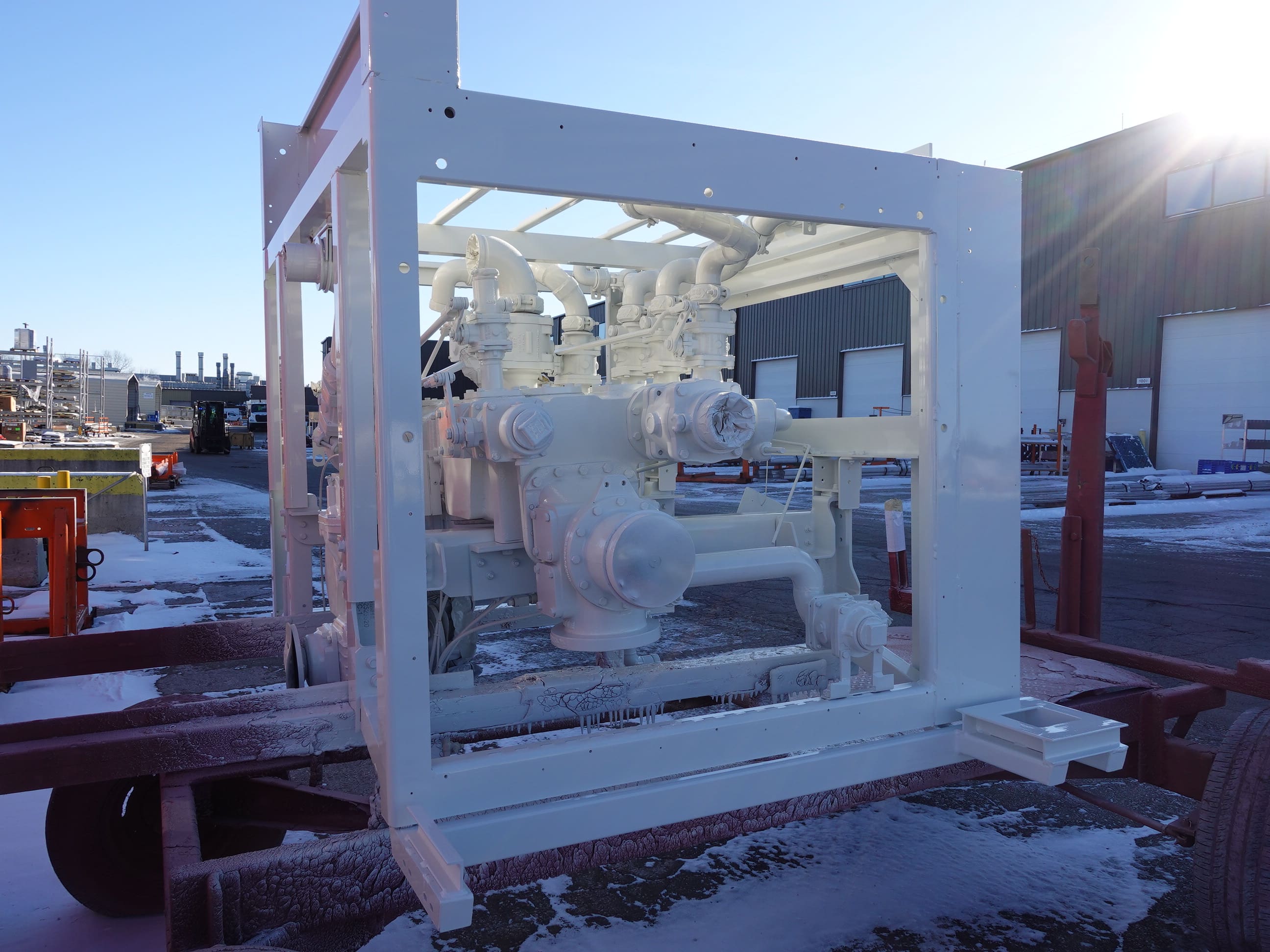

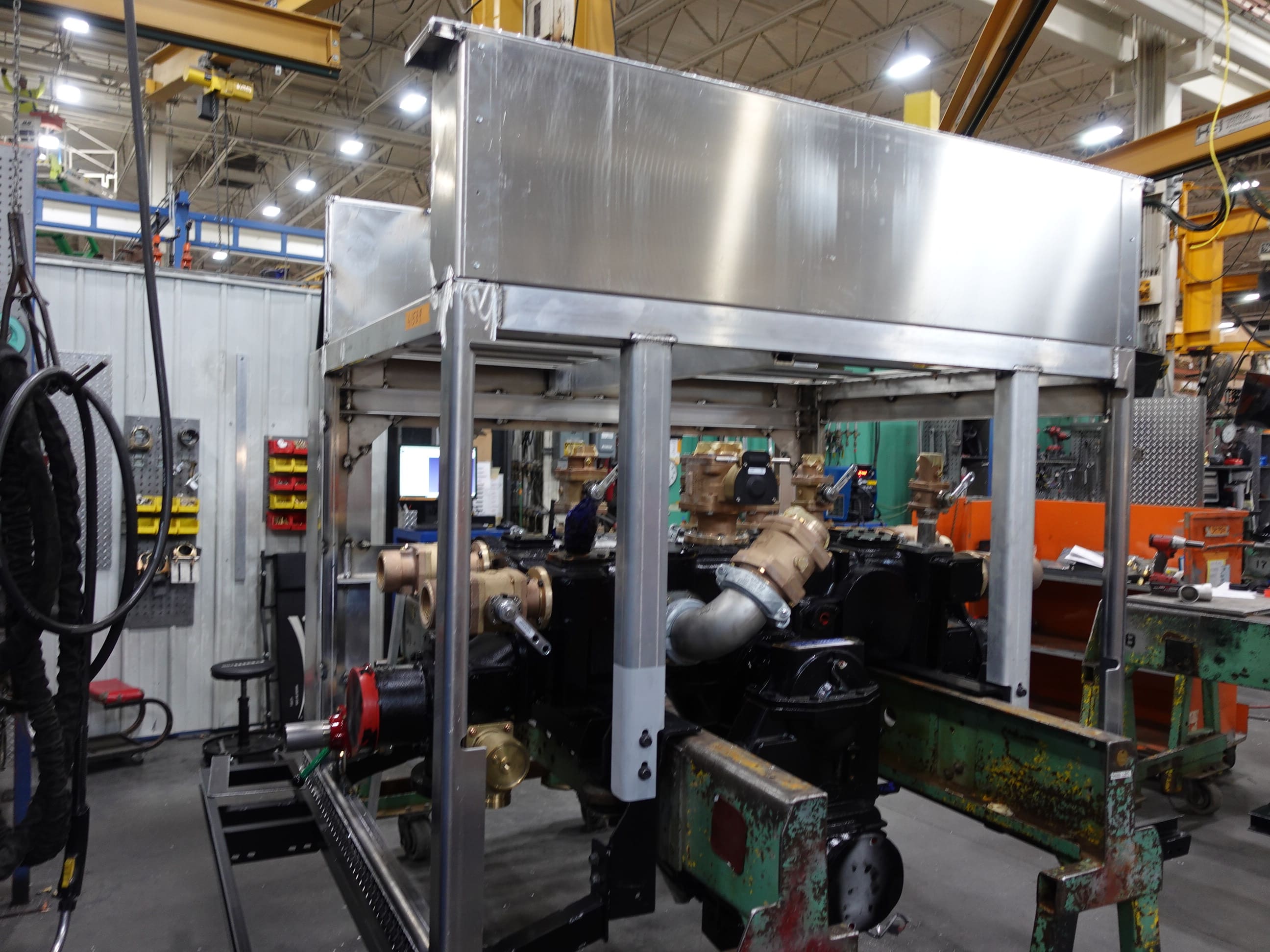

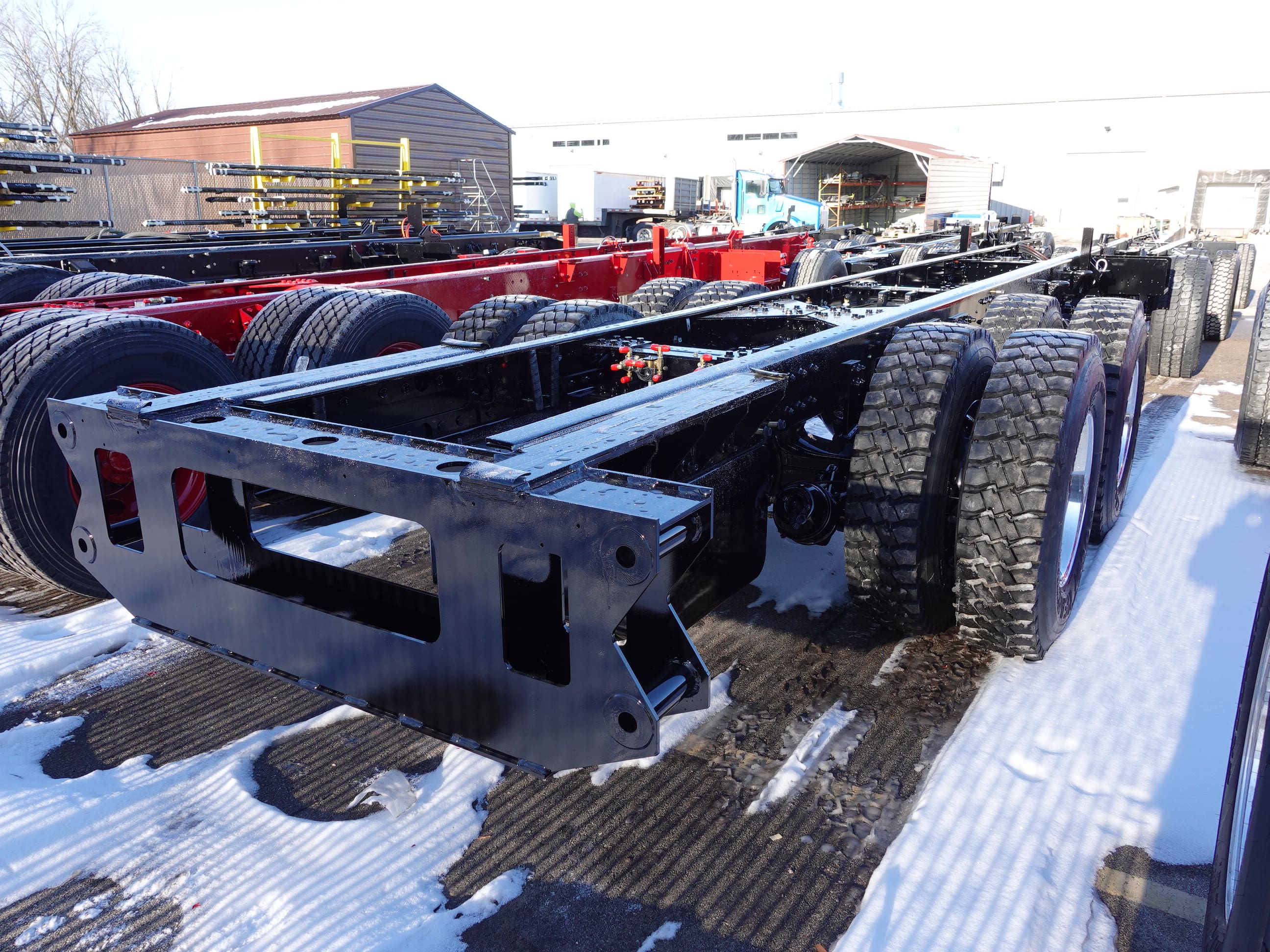

In this report, the cab was merged with the frame followed by pump house installation, the torque box arrived and was staged, and the body continued through paint.

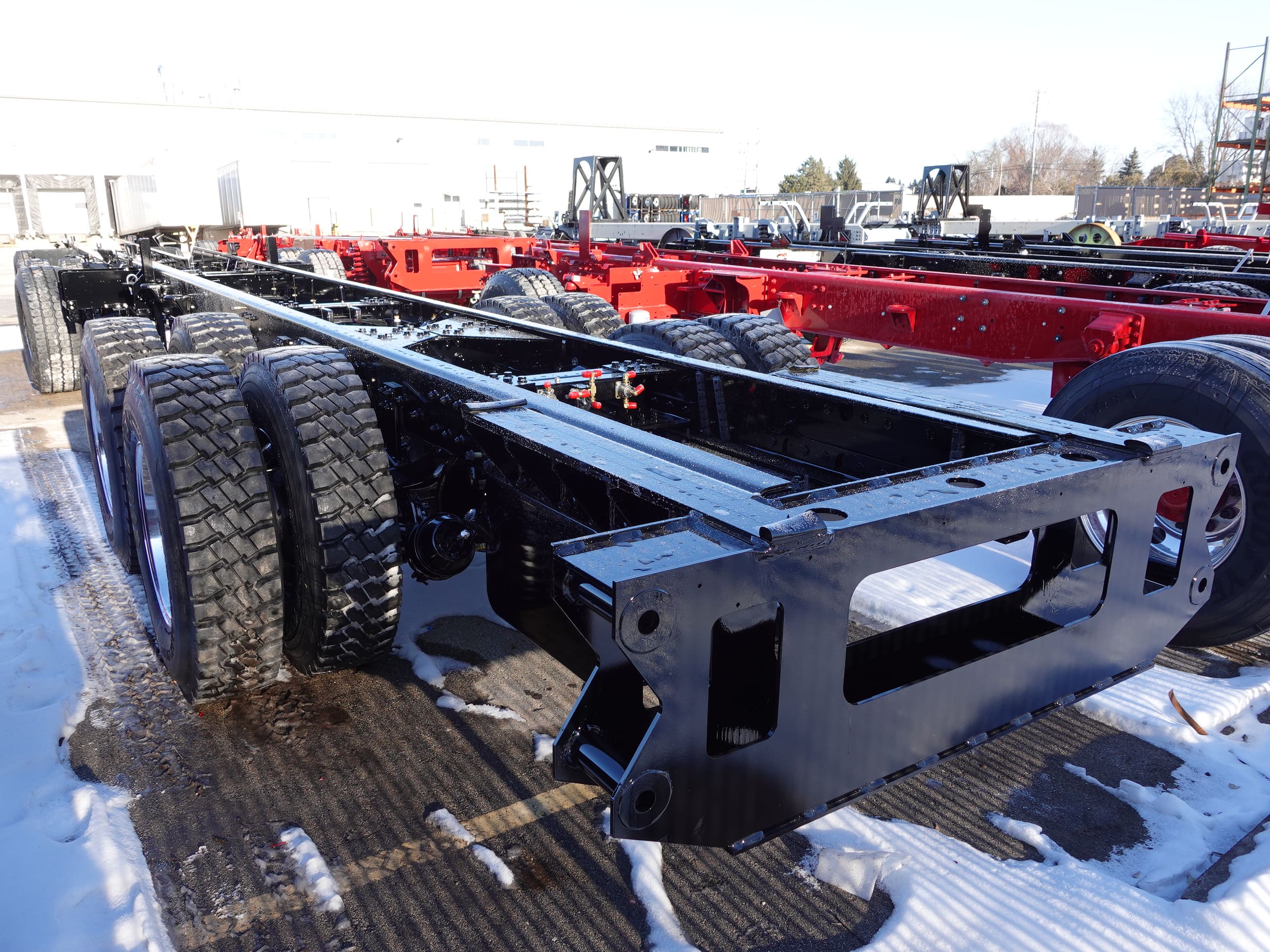

02-06-26

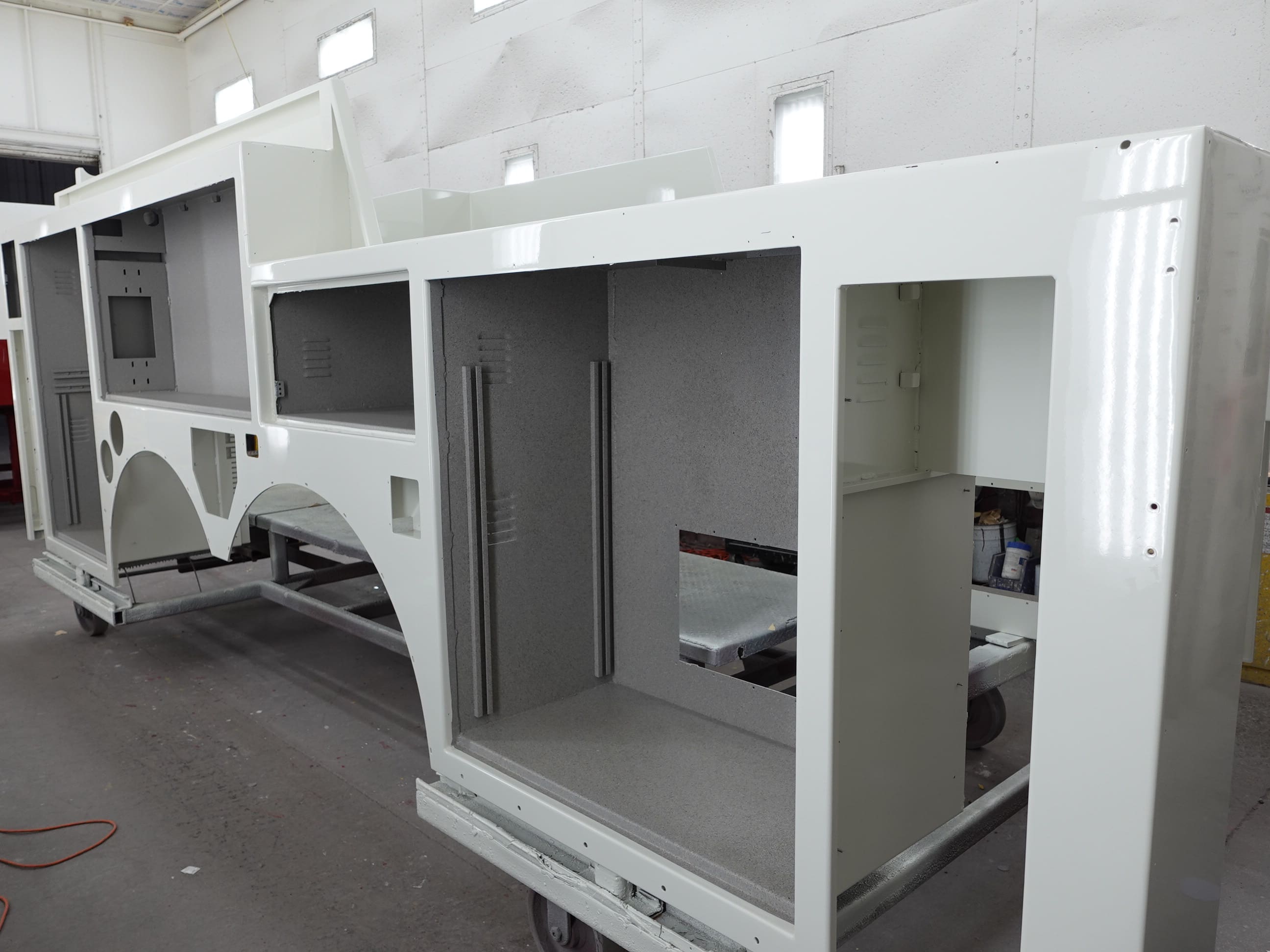

In this report, the cab completed initial assembly, the frame build continued, the pump house was staged, and the body began the paint process with metal finishing.

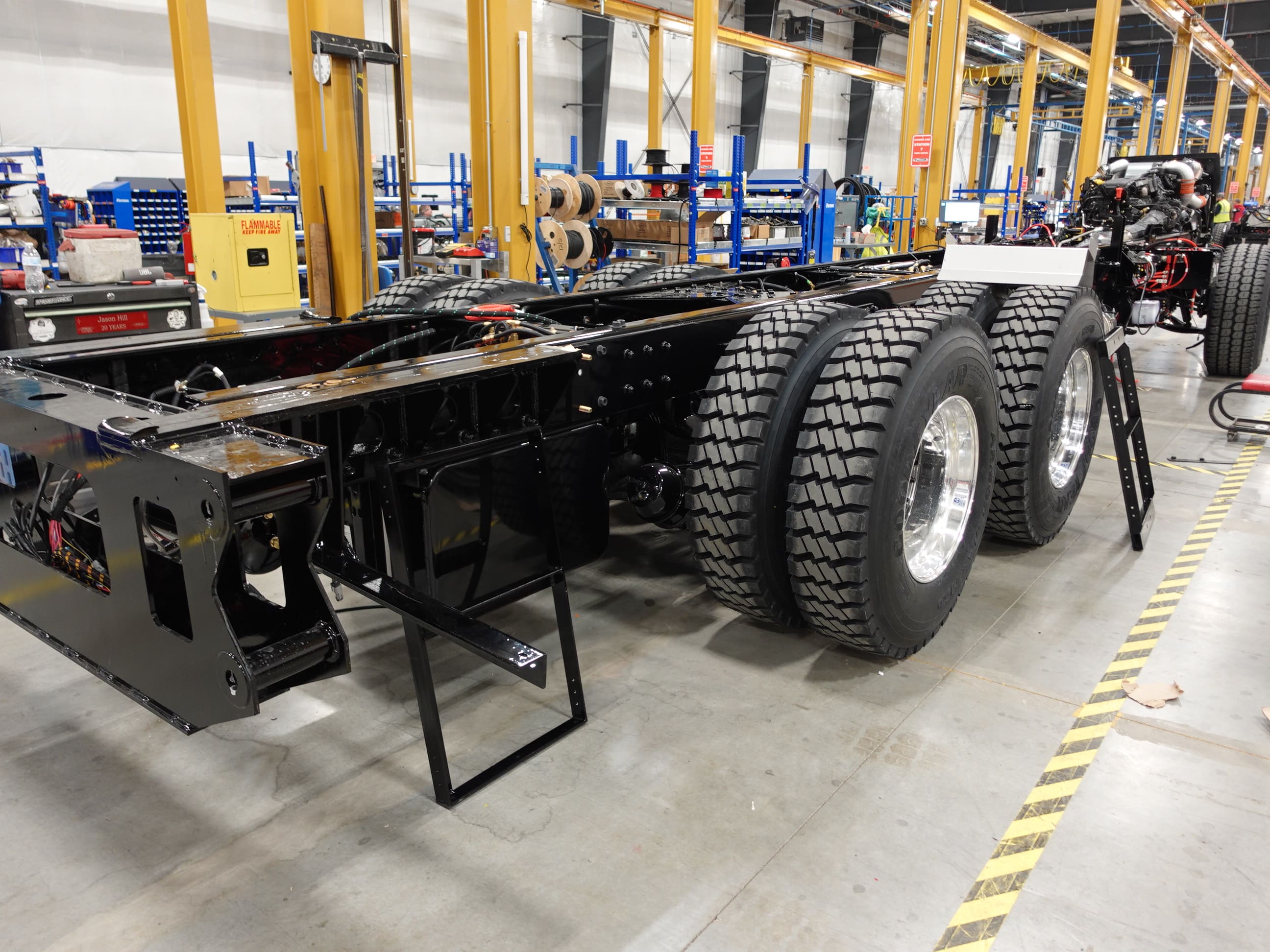

01-30-26

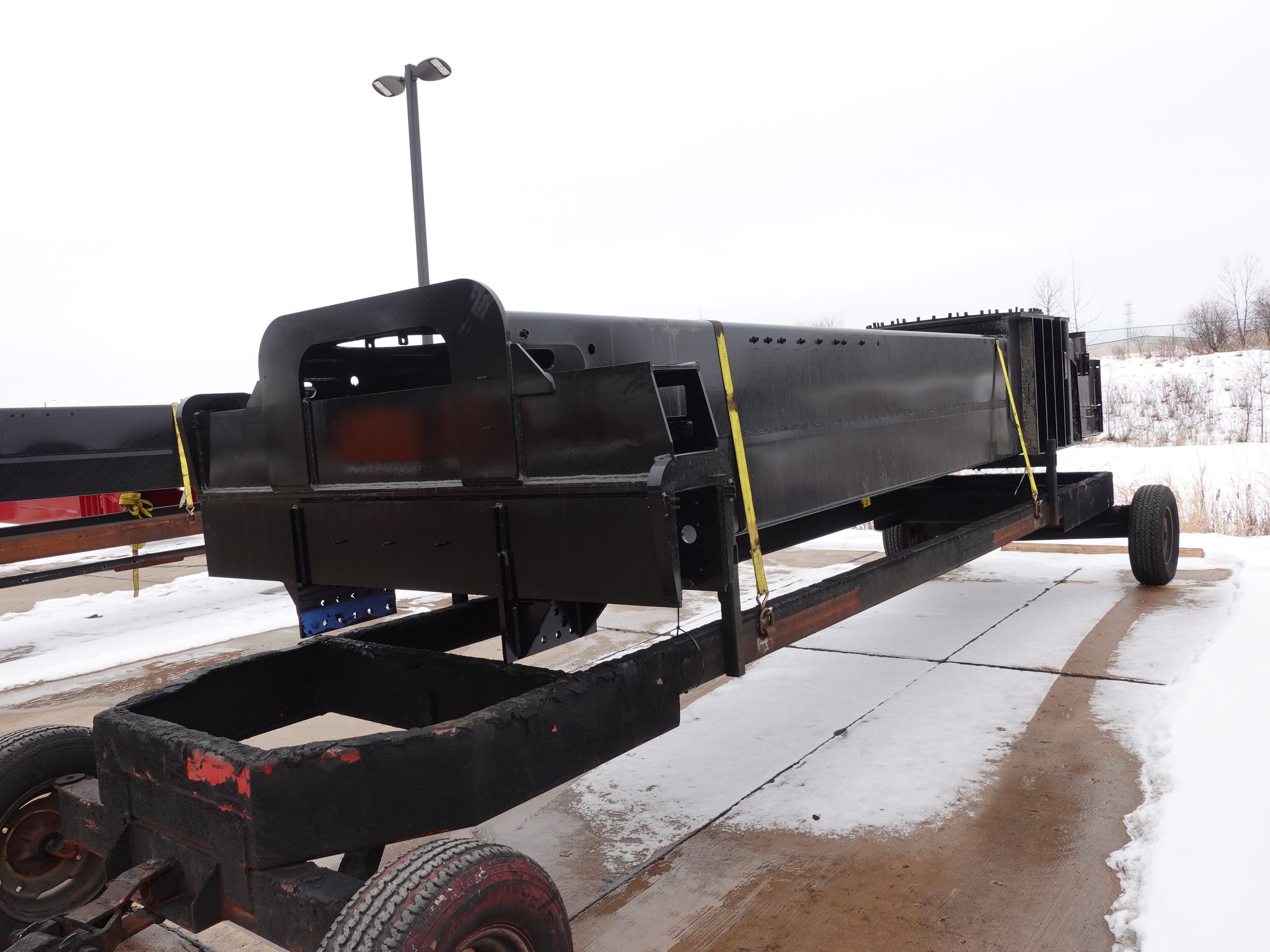

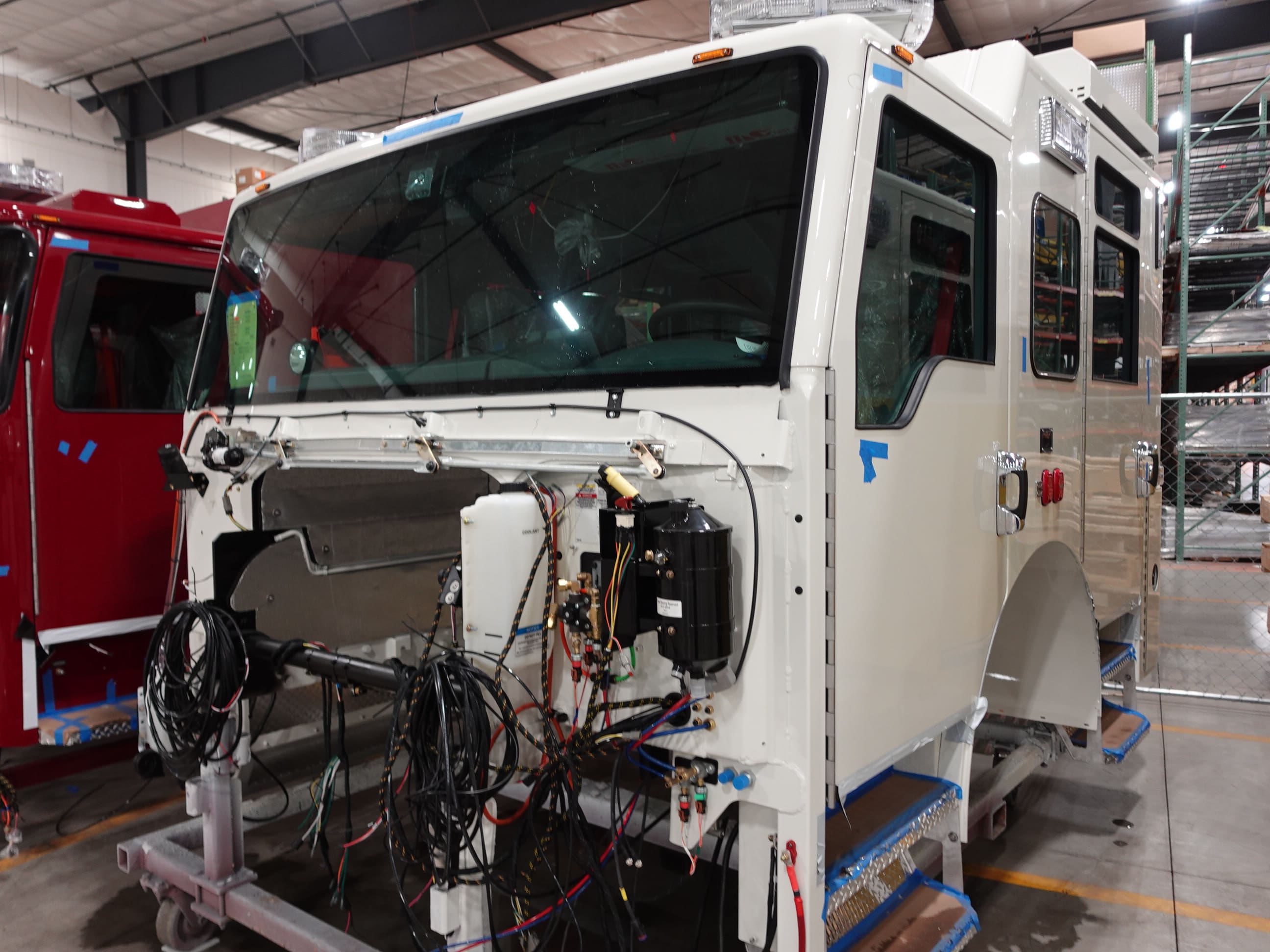

In this report, the cab began initial assembly, the frame build began, the pump house completed initial assembly, and the body was unavailable for photos.
01-23-26

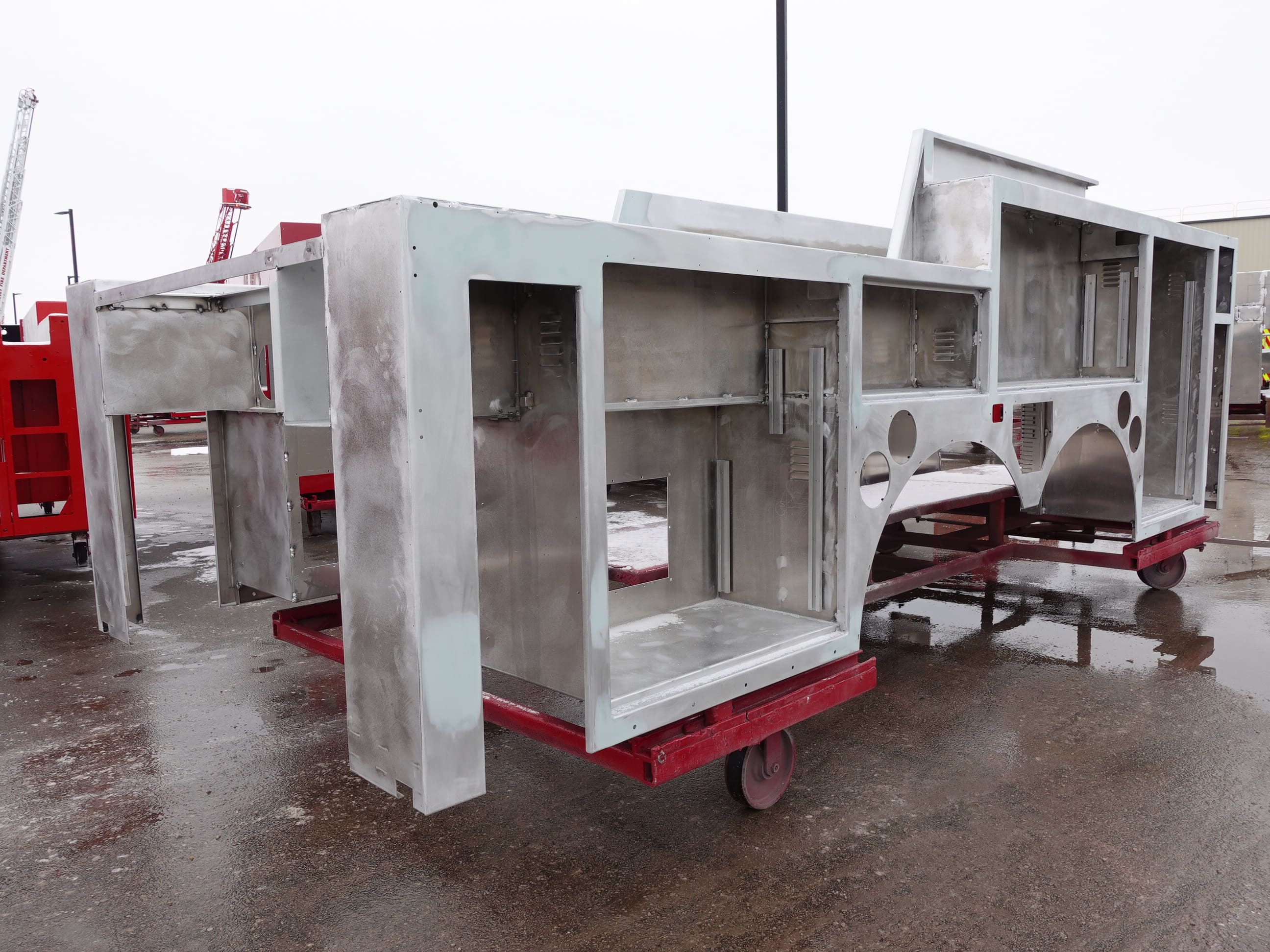

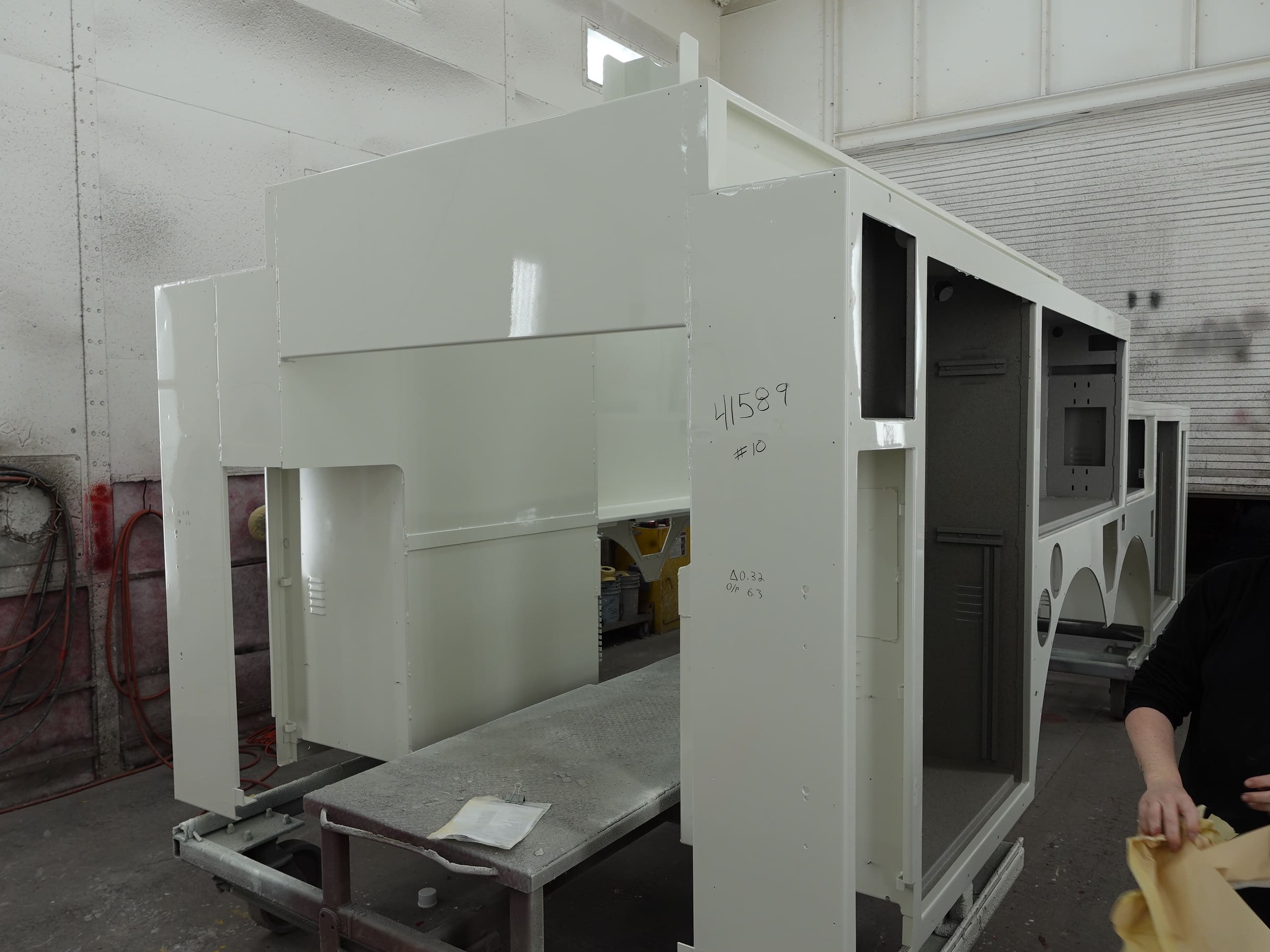

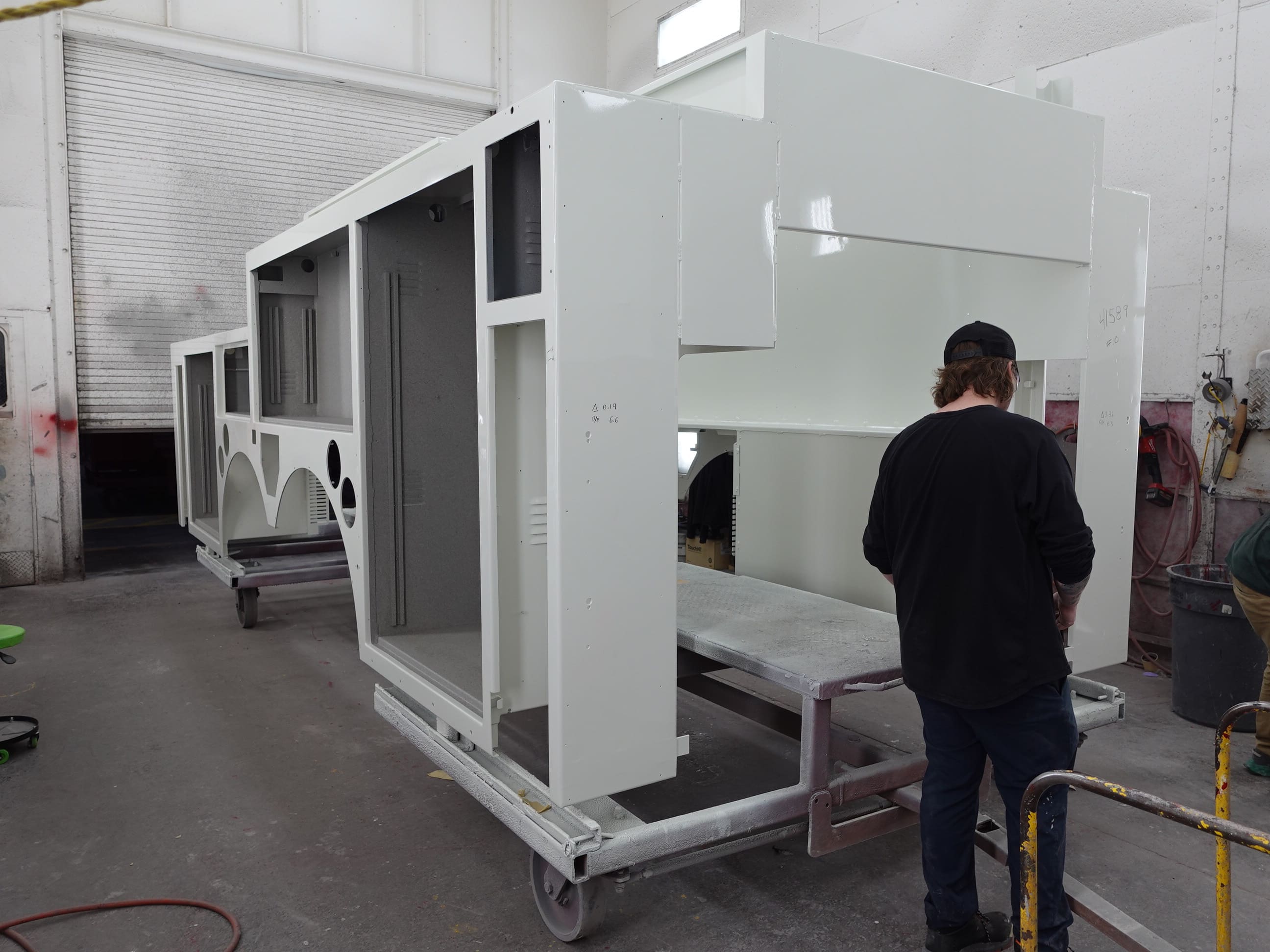

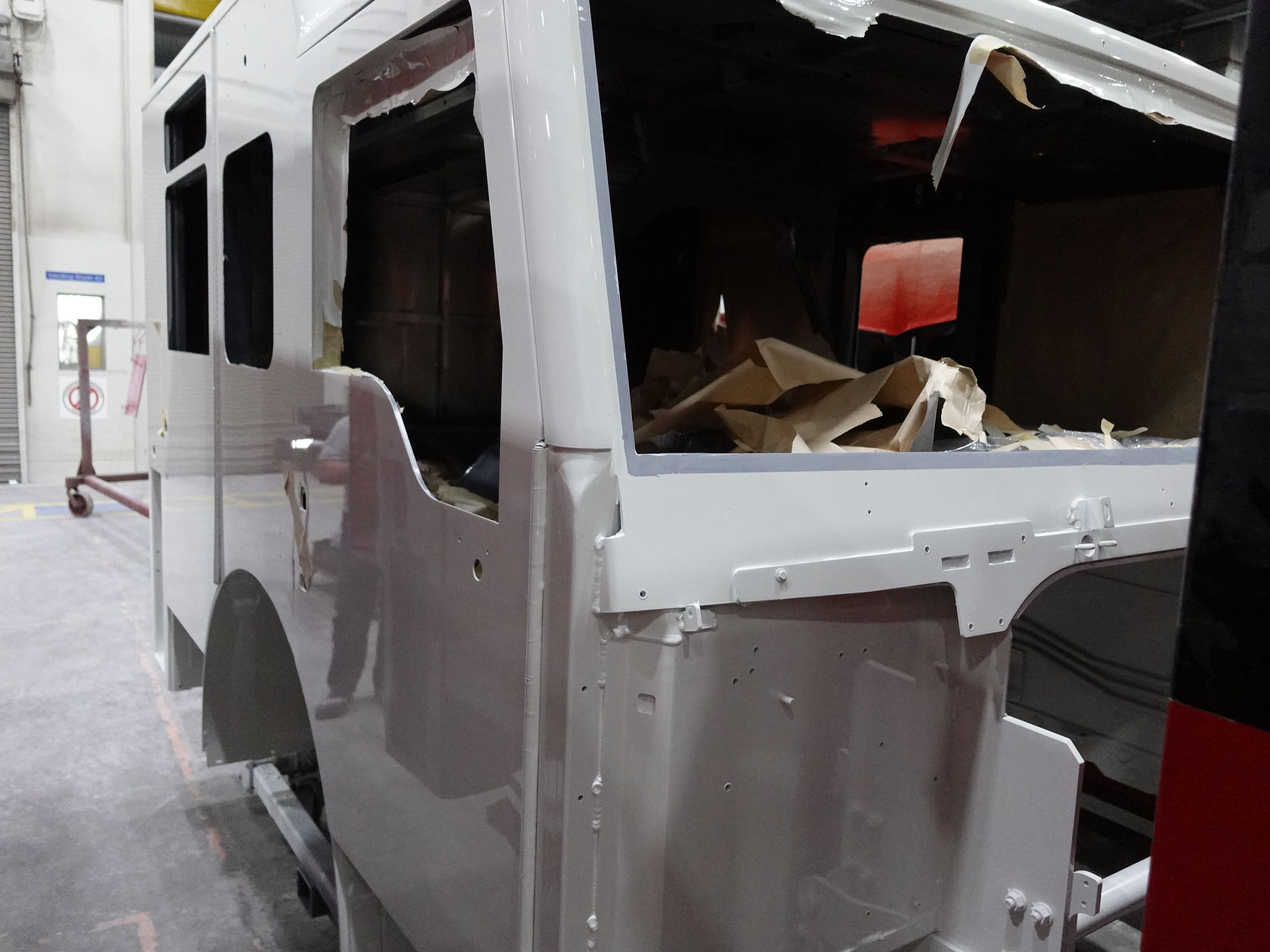

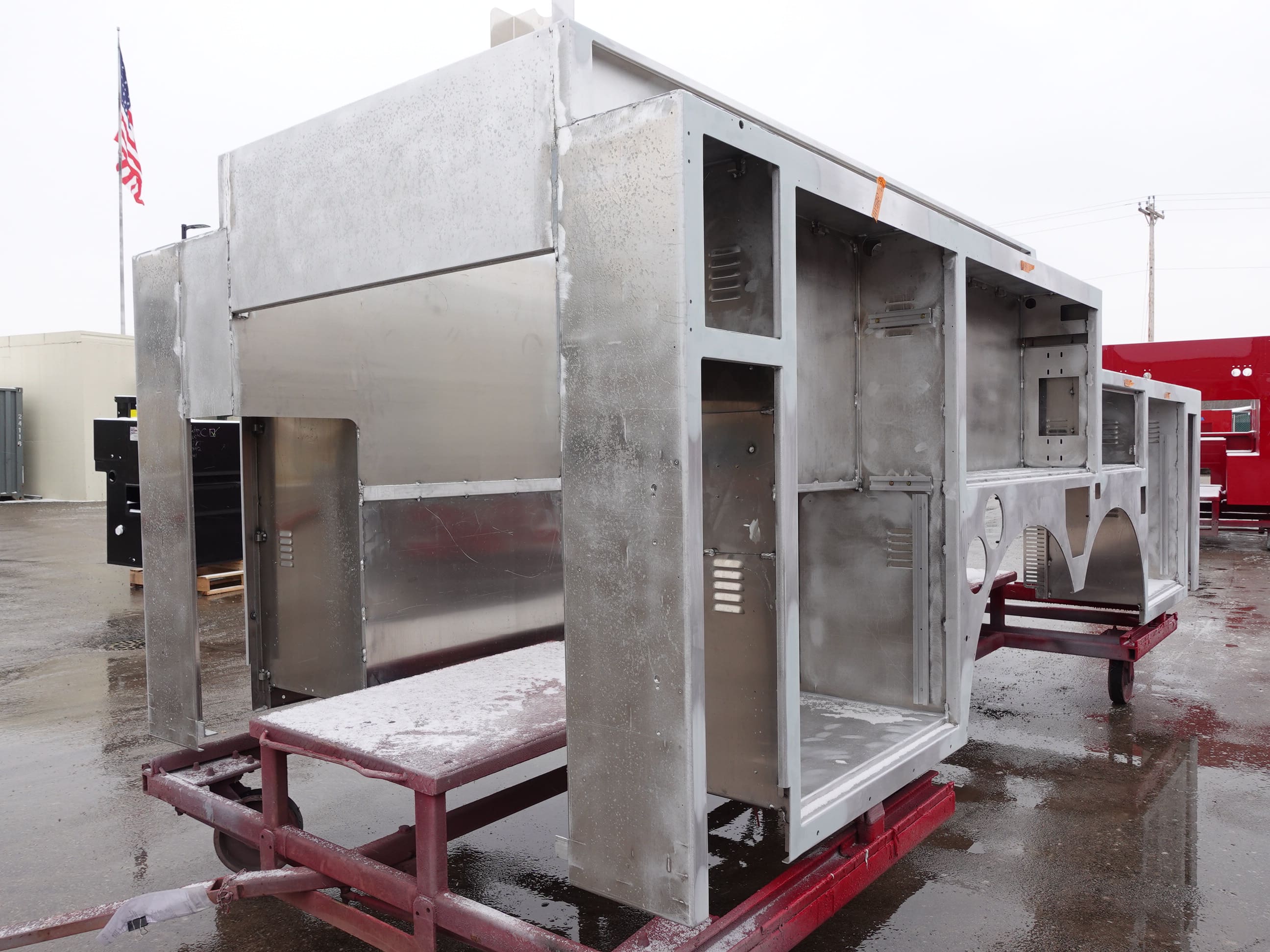

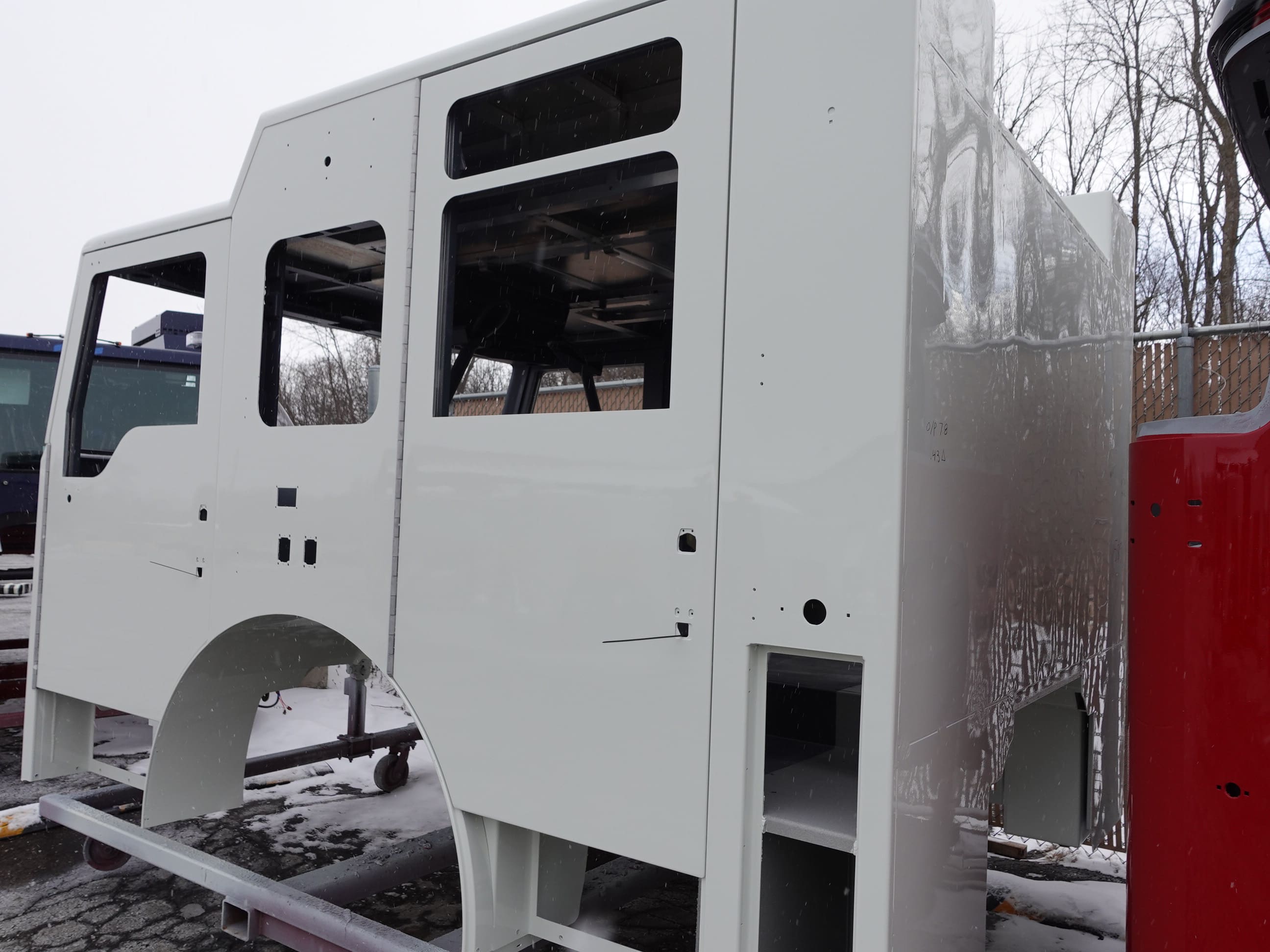

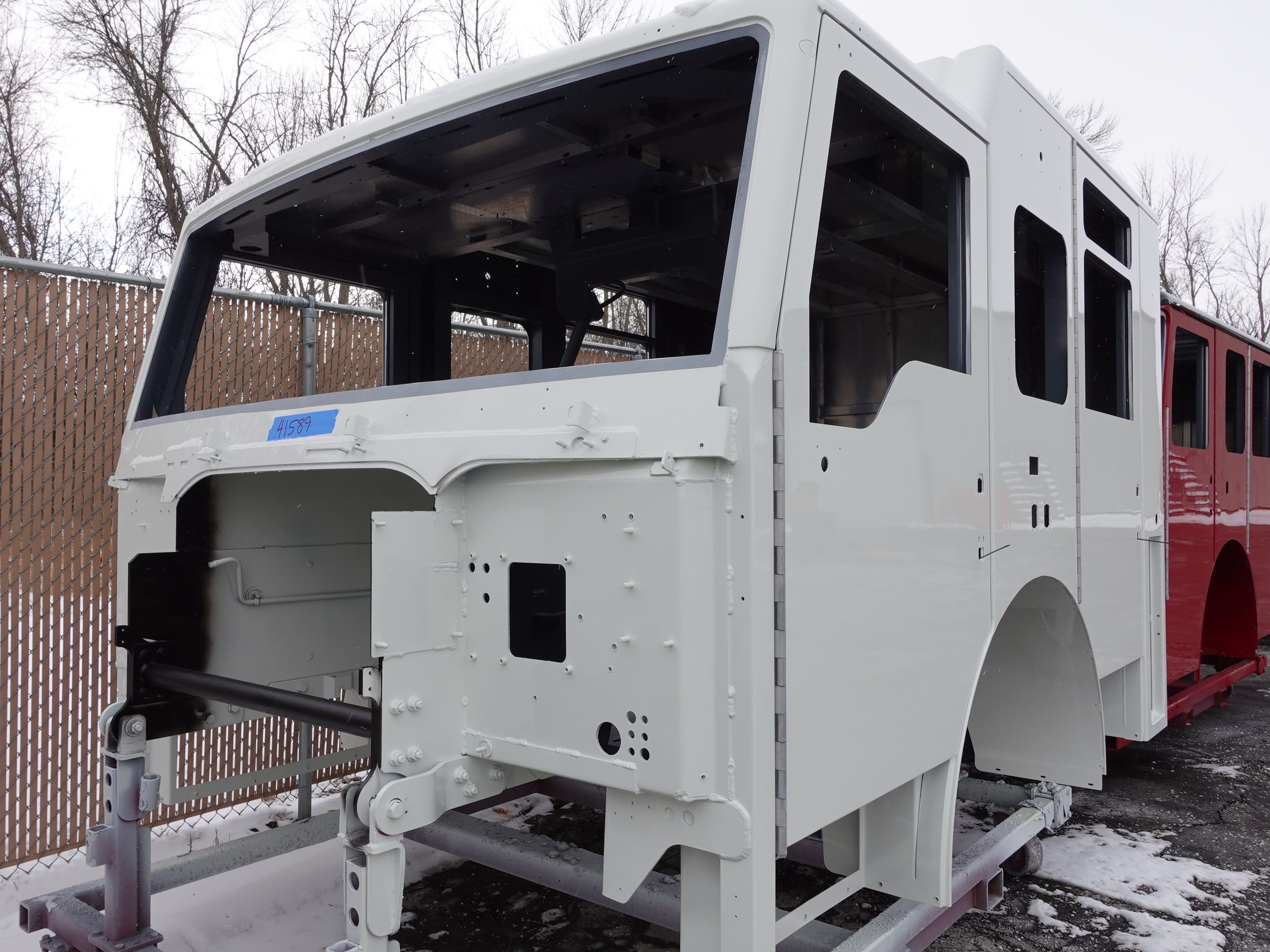

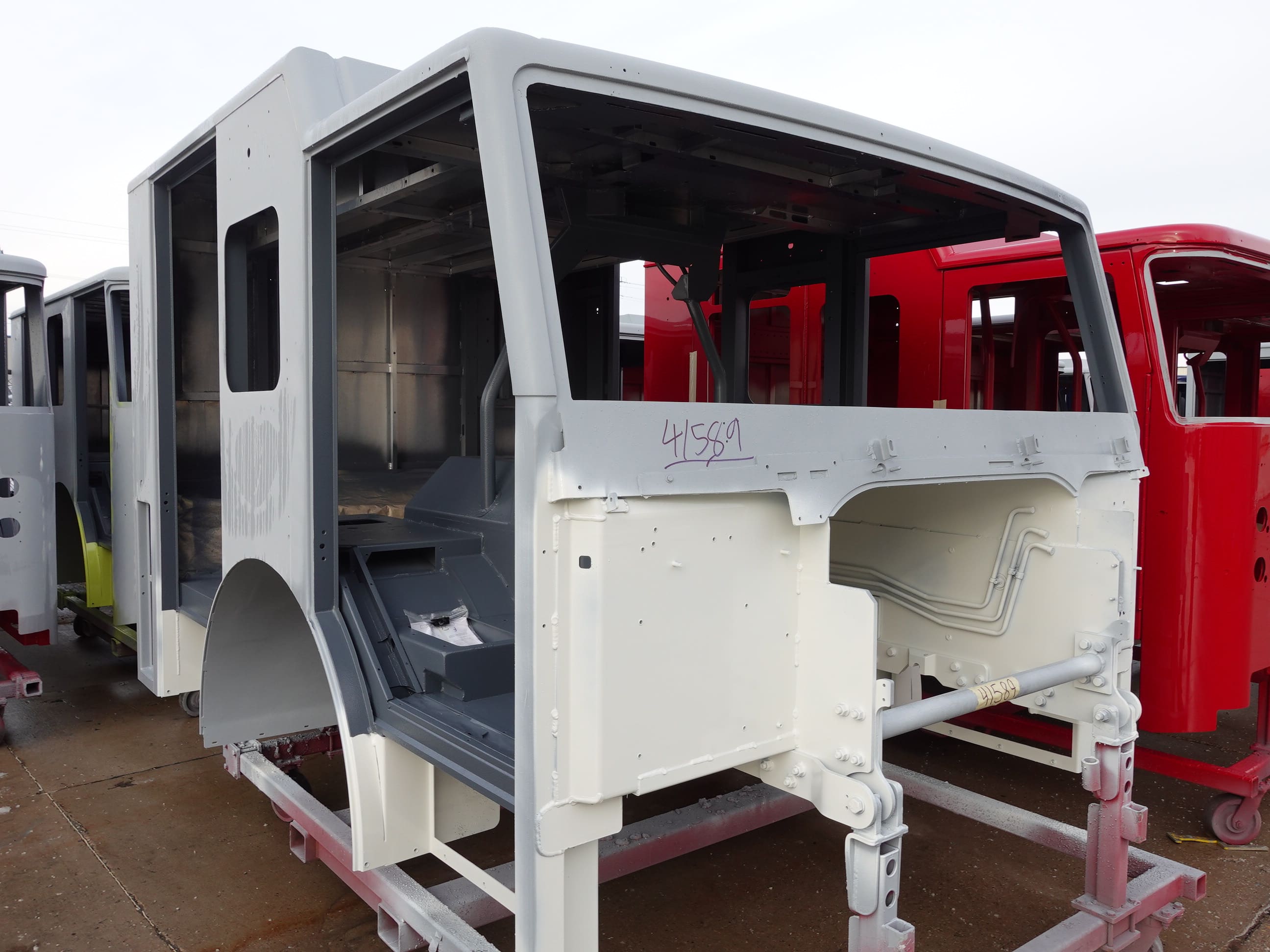

In this report, the cab completed the paint process, the pump house was painted then staged to continue initial assembly, and the body was fabricated.

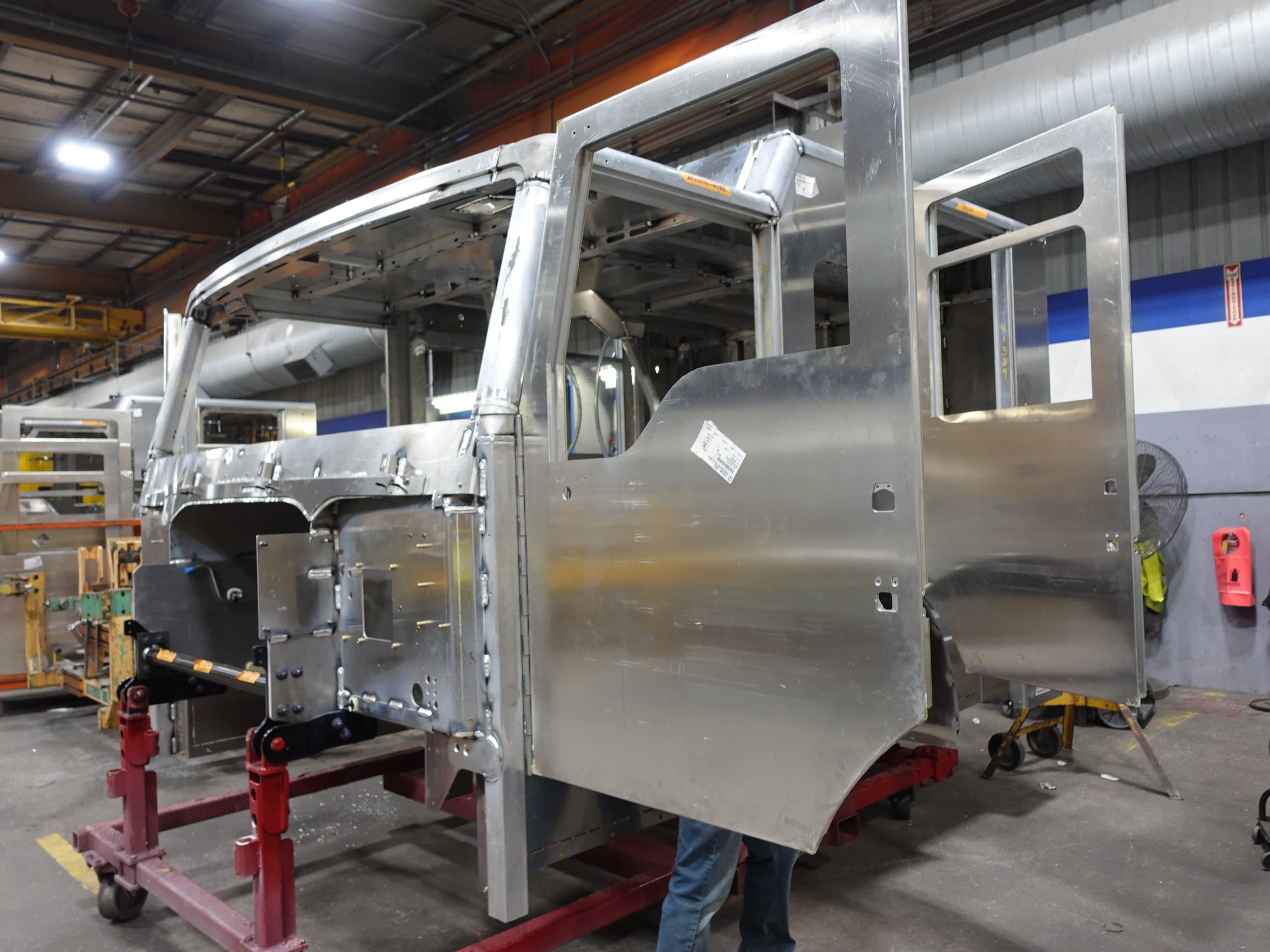

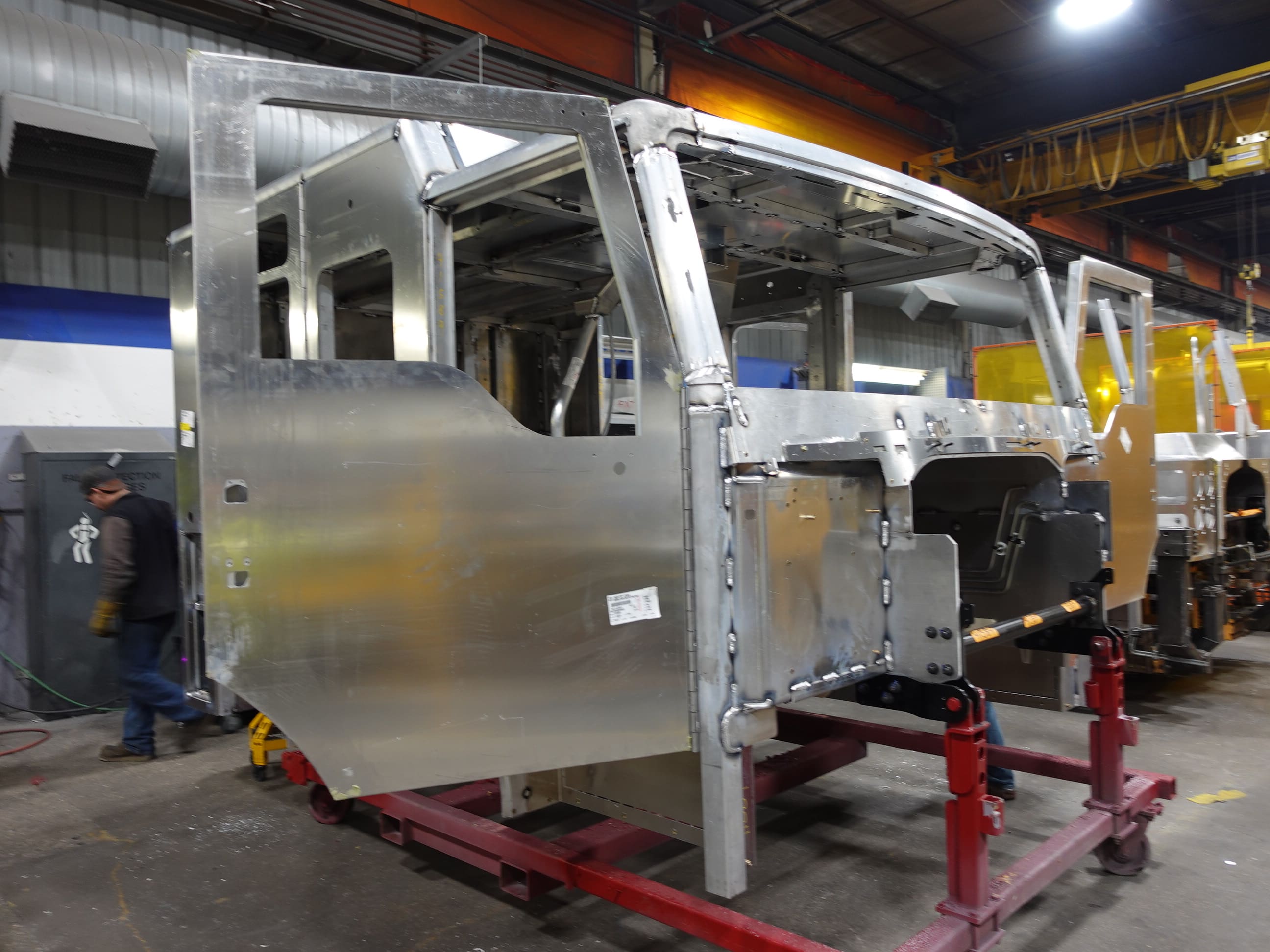

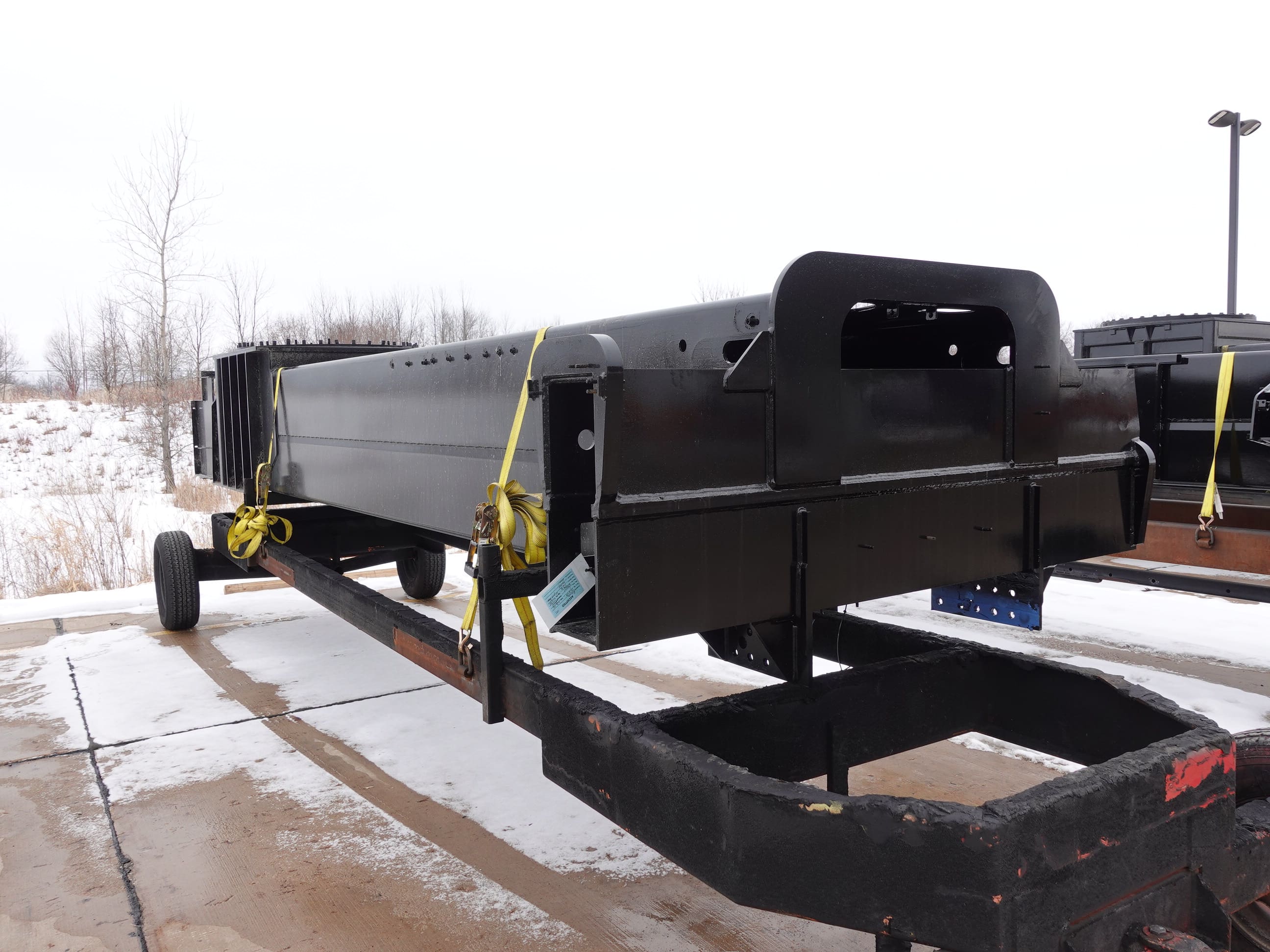

01-16-26

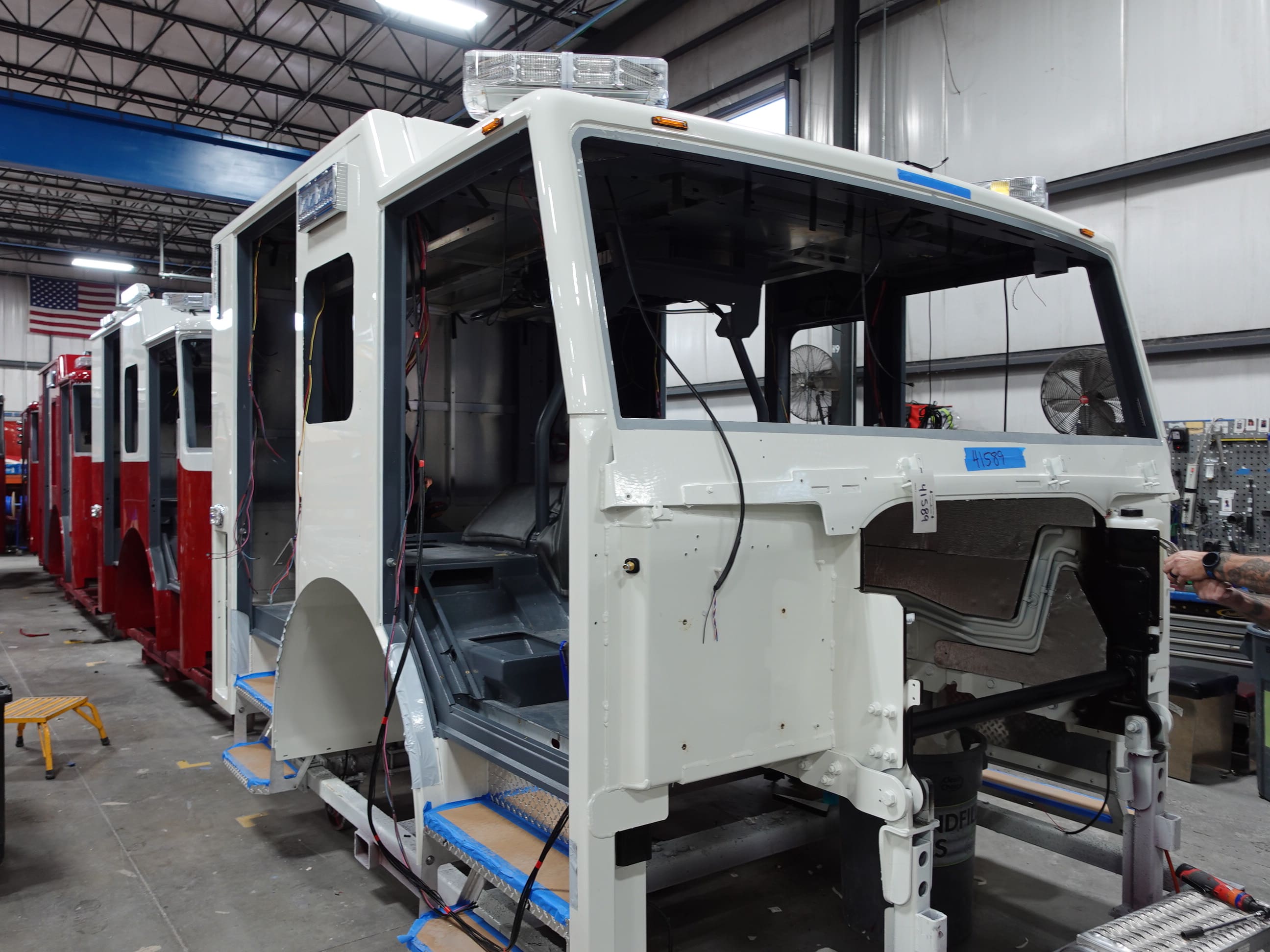

In this report, the cab continued through paint while the pump house began initial assembly.

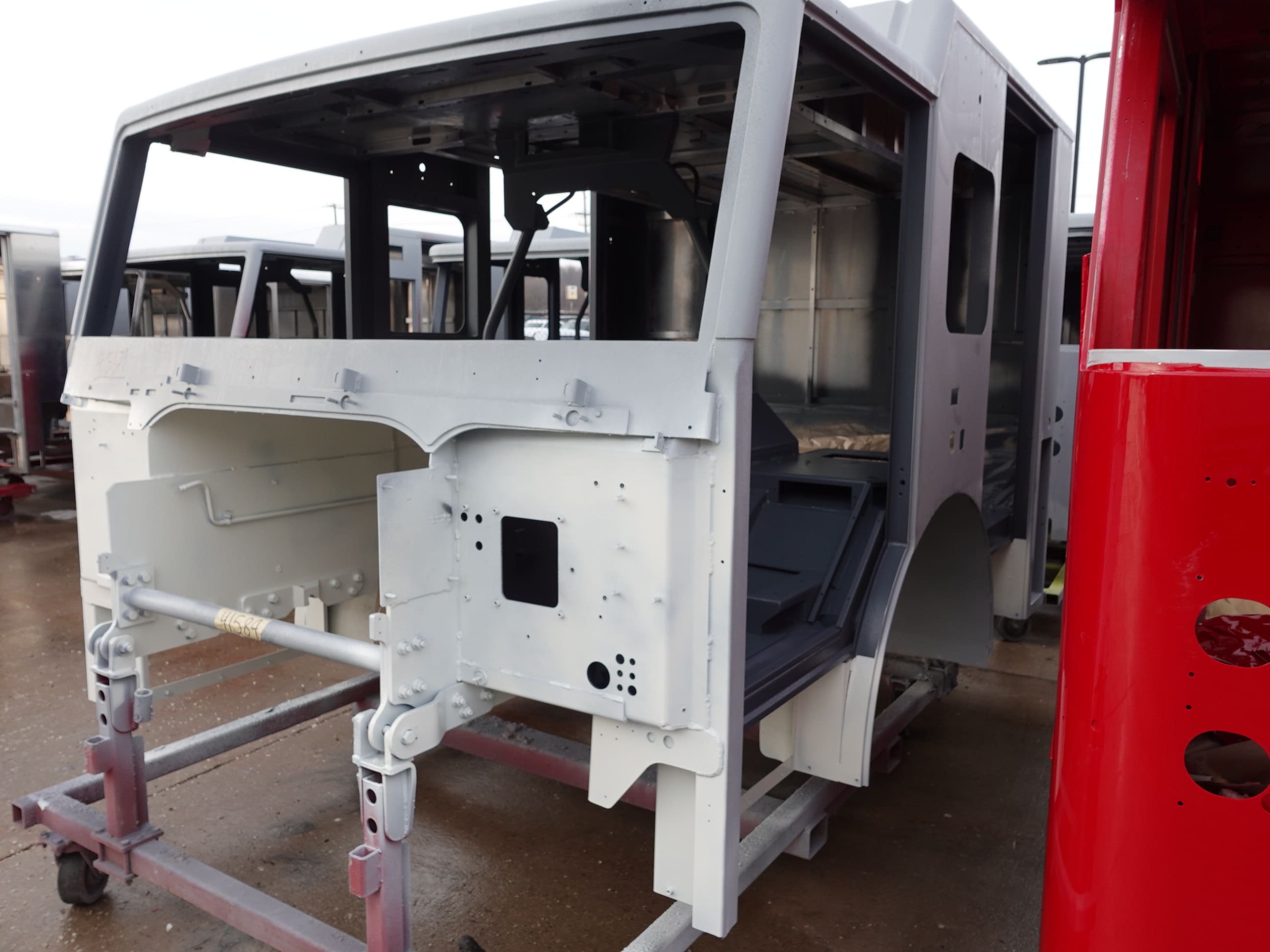

01-09-26
In this report, the cab completed fabrication and began the paint process while the pump house structure was fabricated.
12-19-25
This new Pierce apparatus is now in production! In this report, the cab began fabrication.
