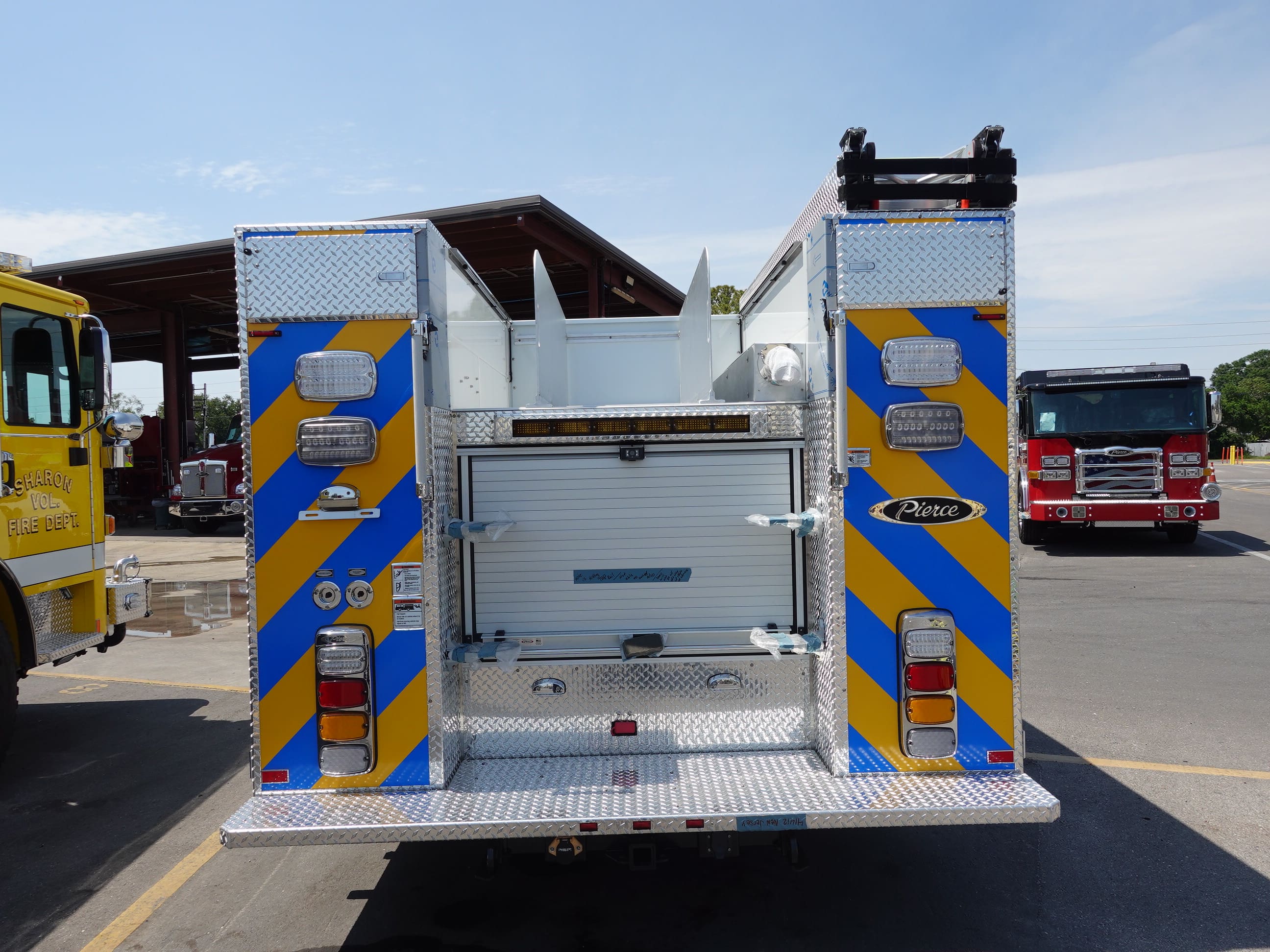

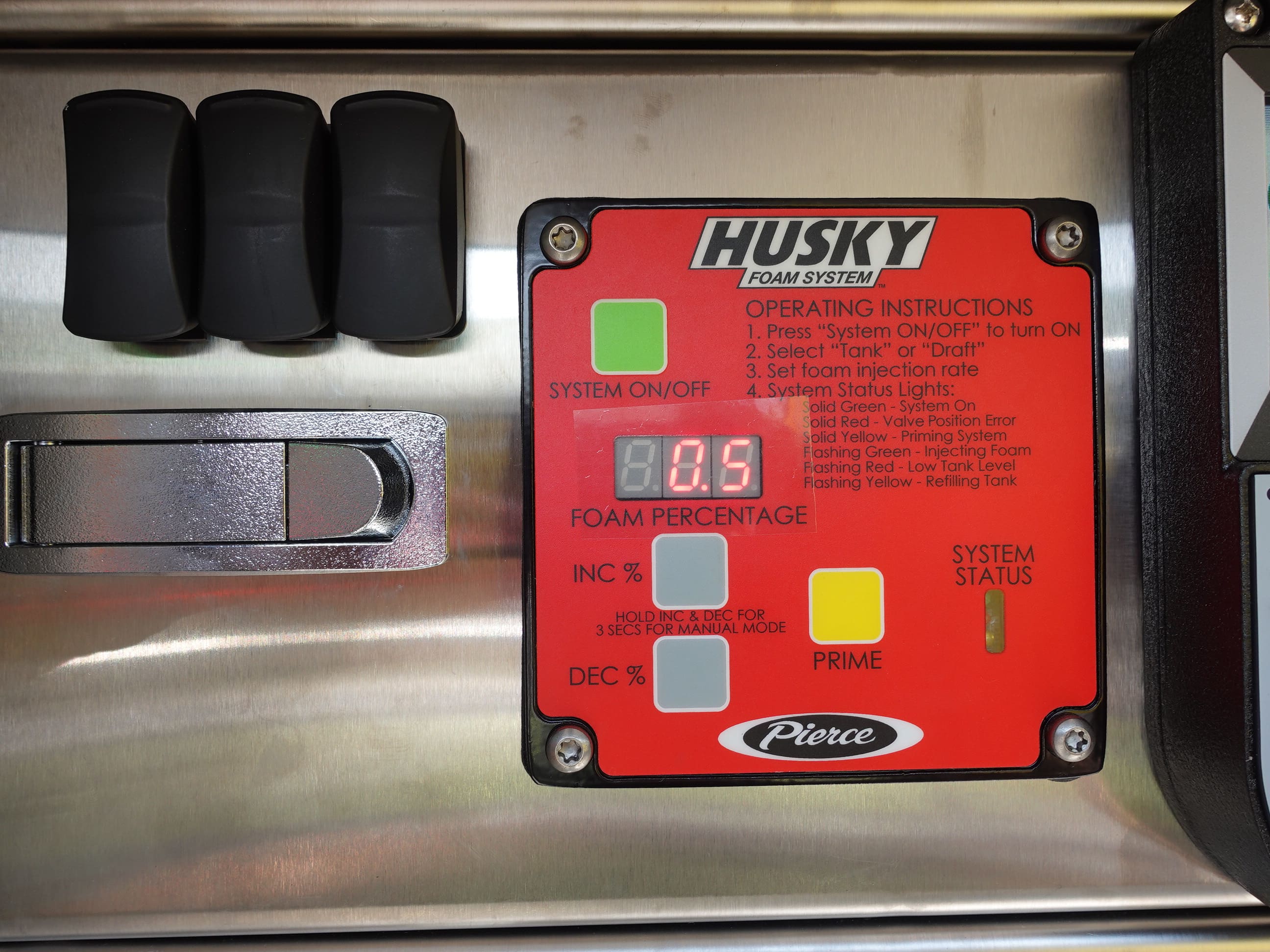

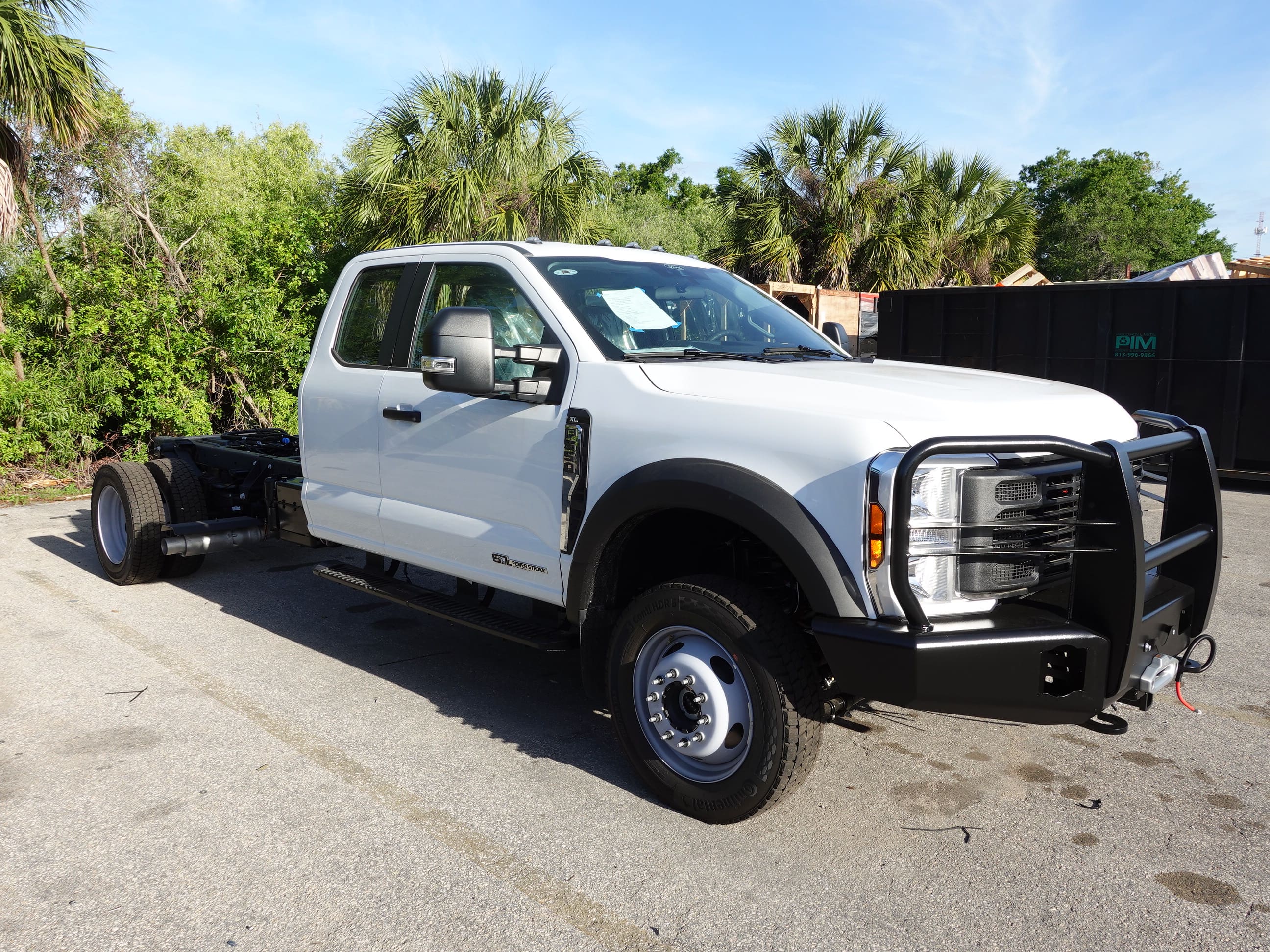

05-15-26

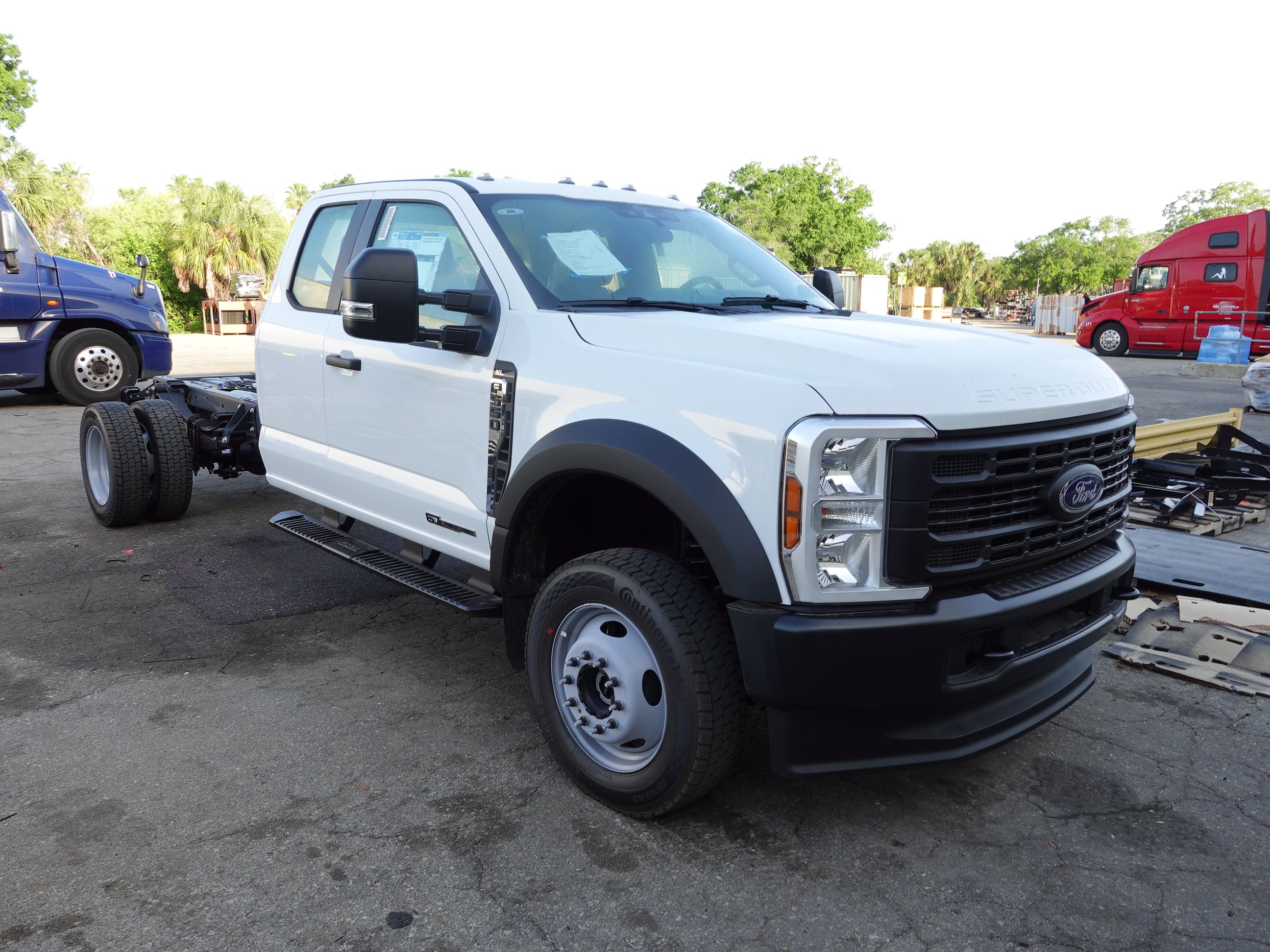

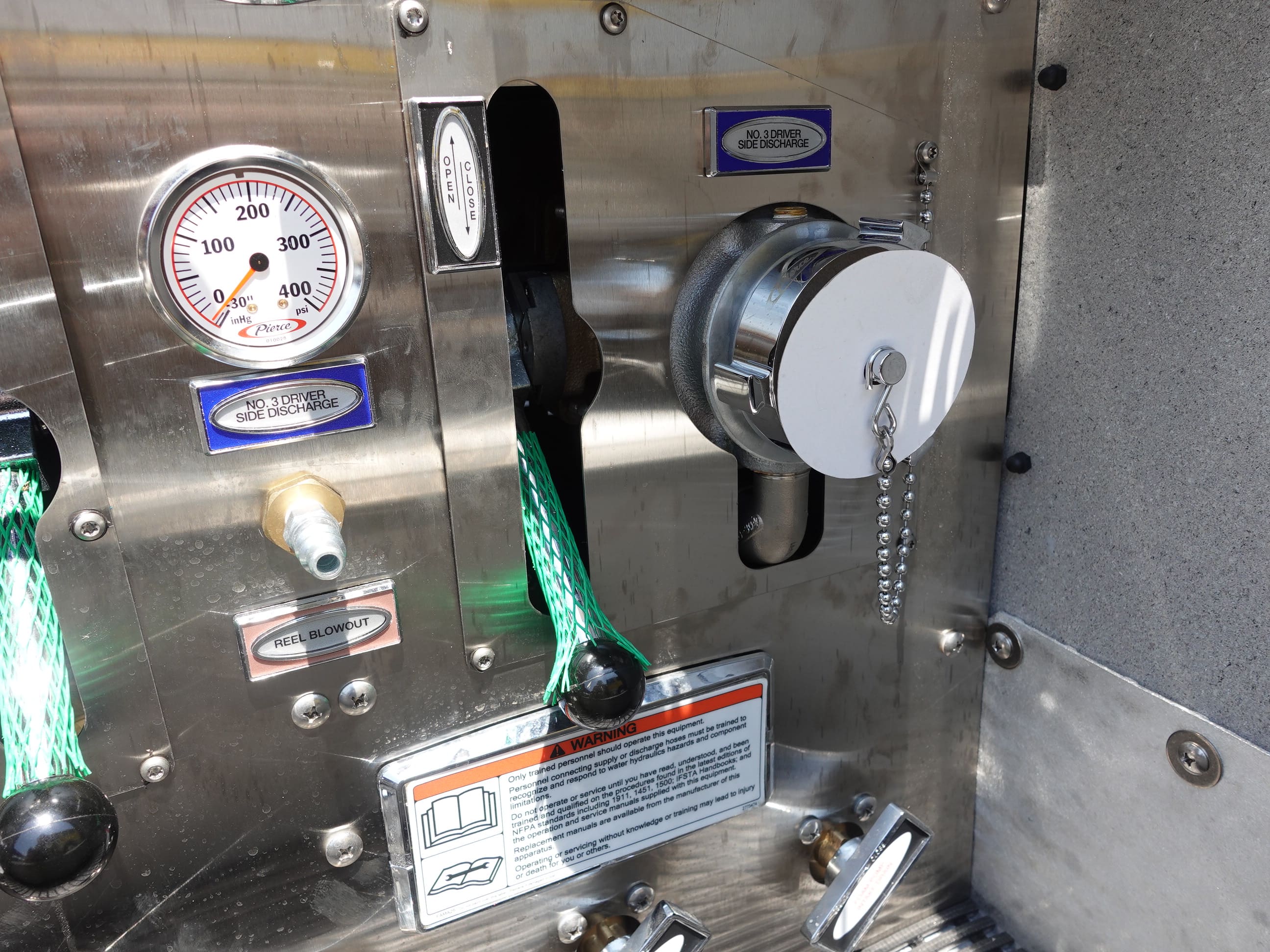

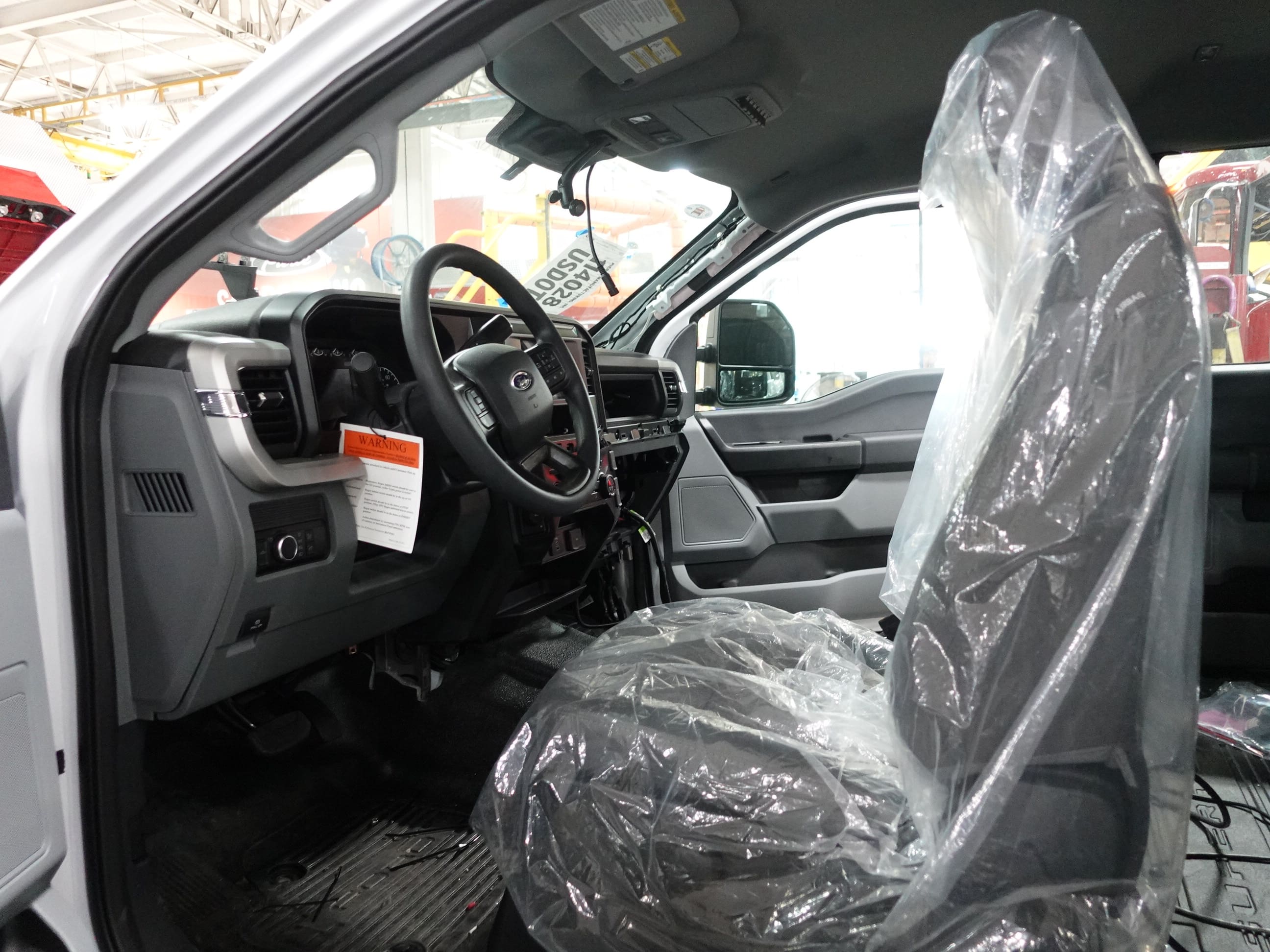

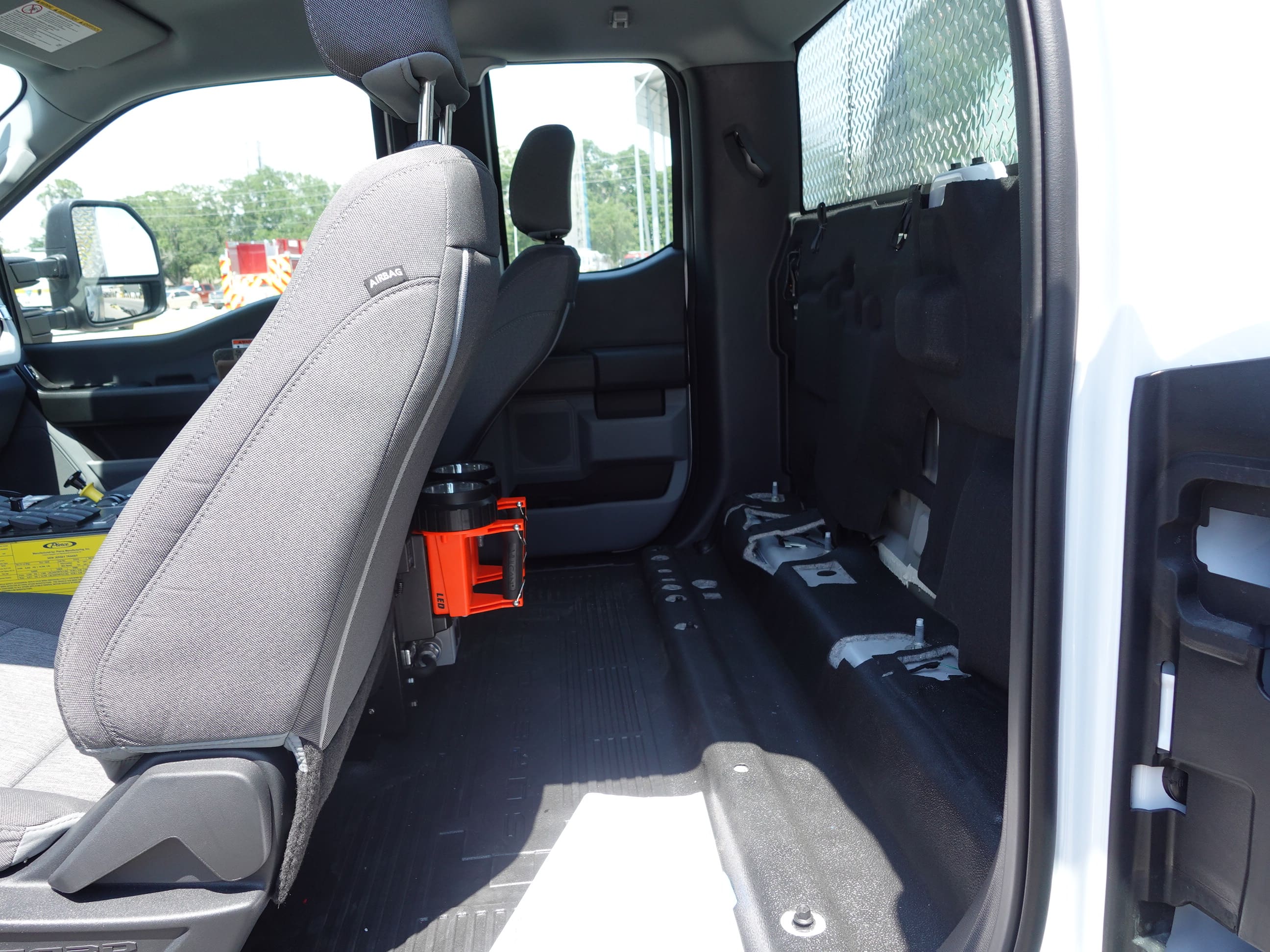

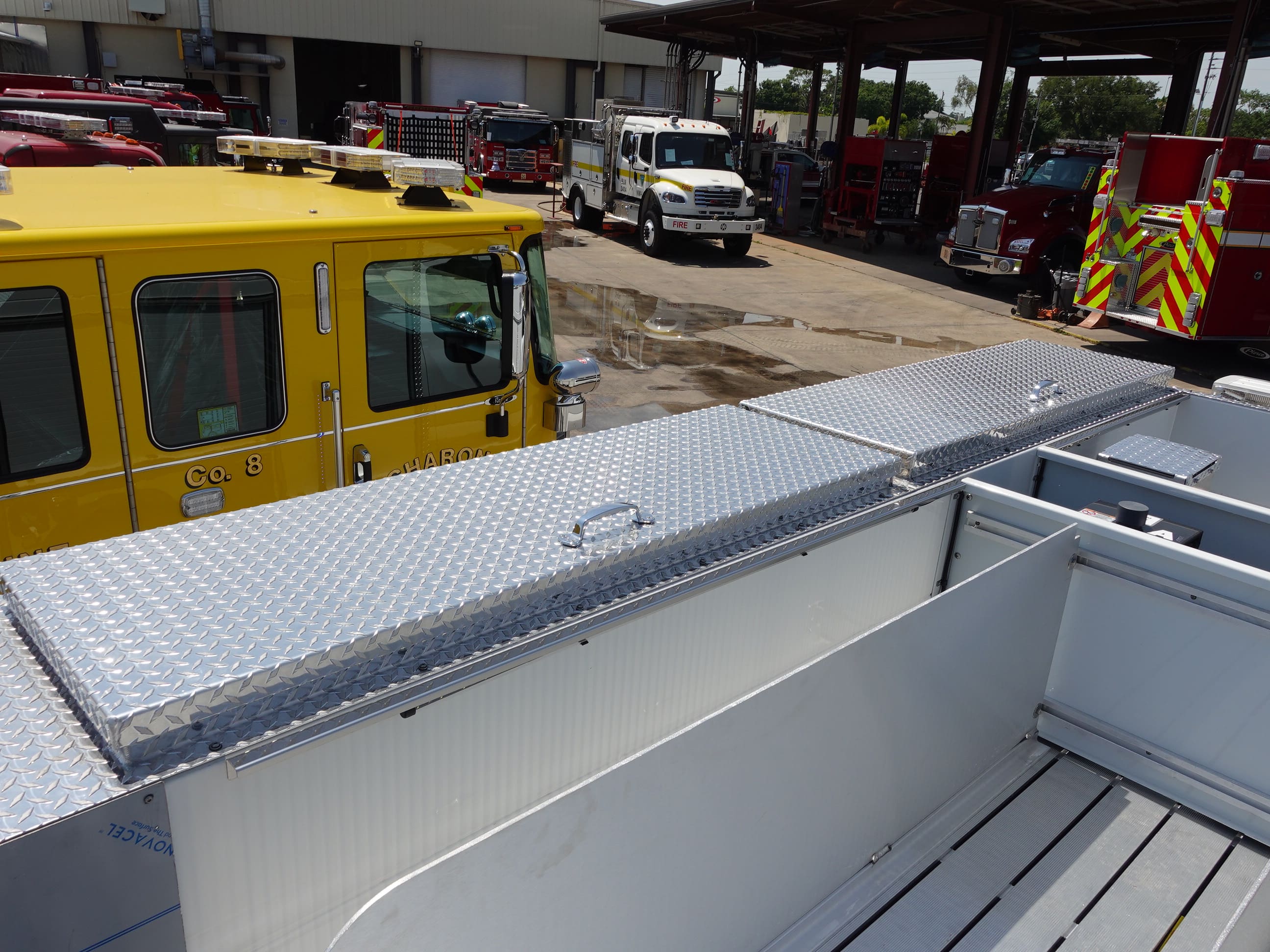

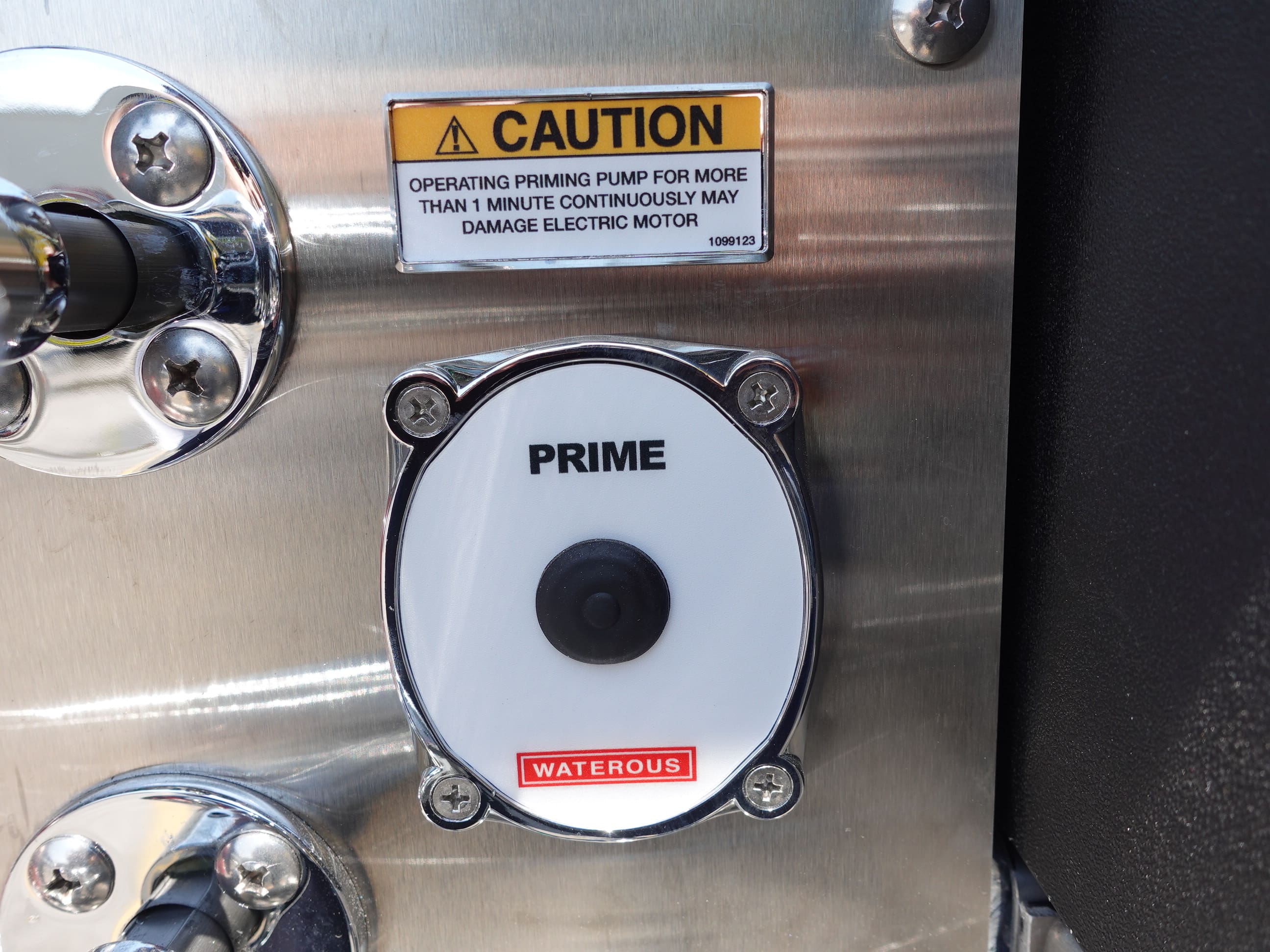

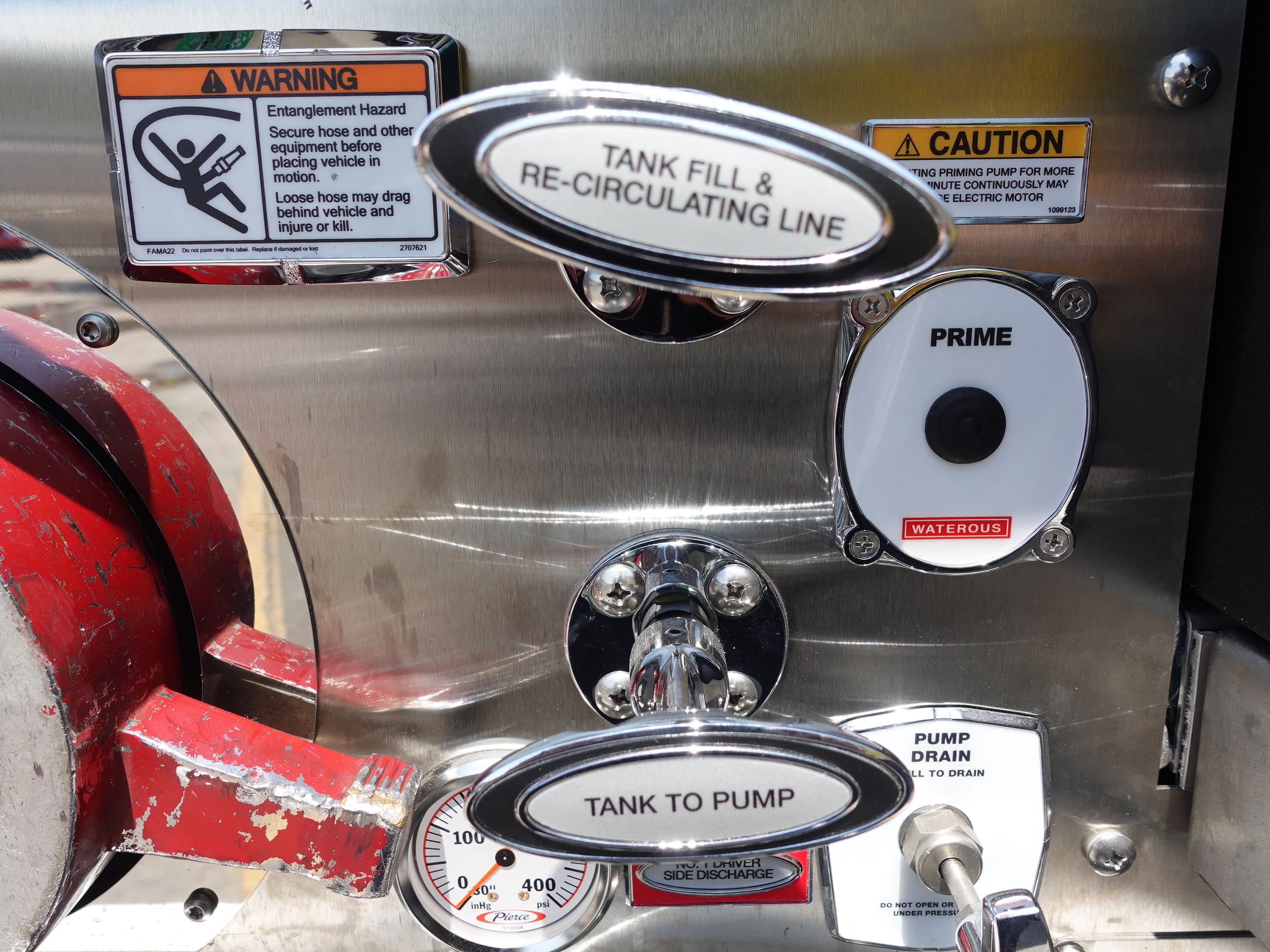

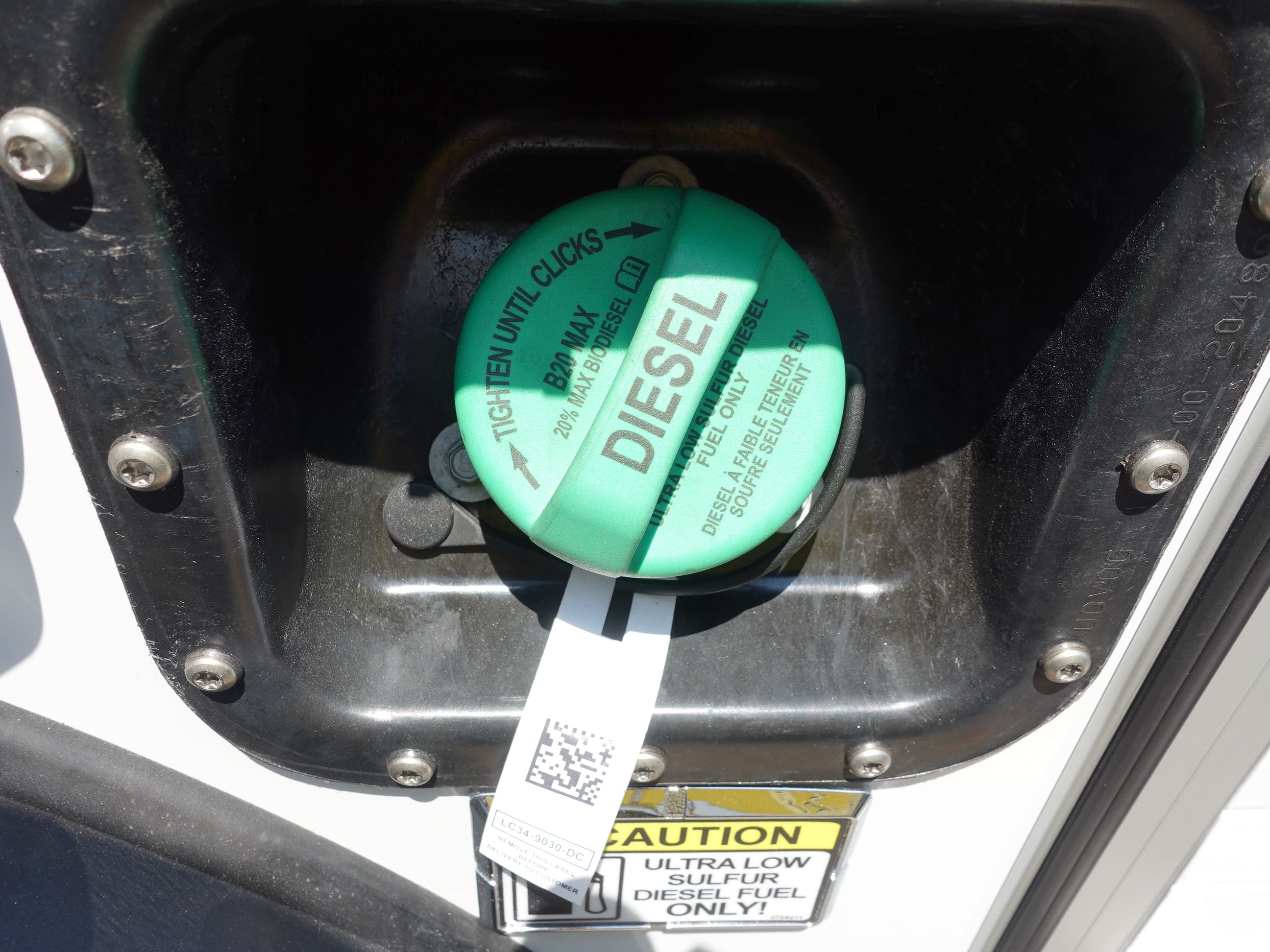

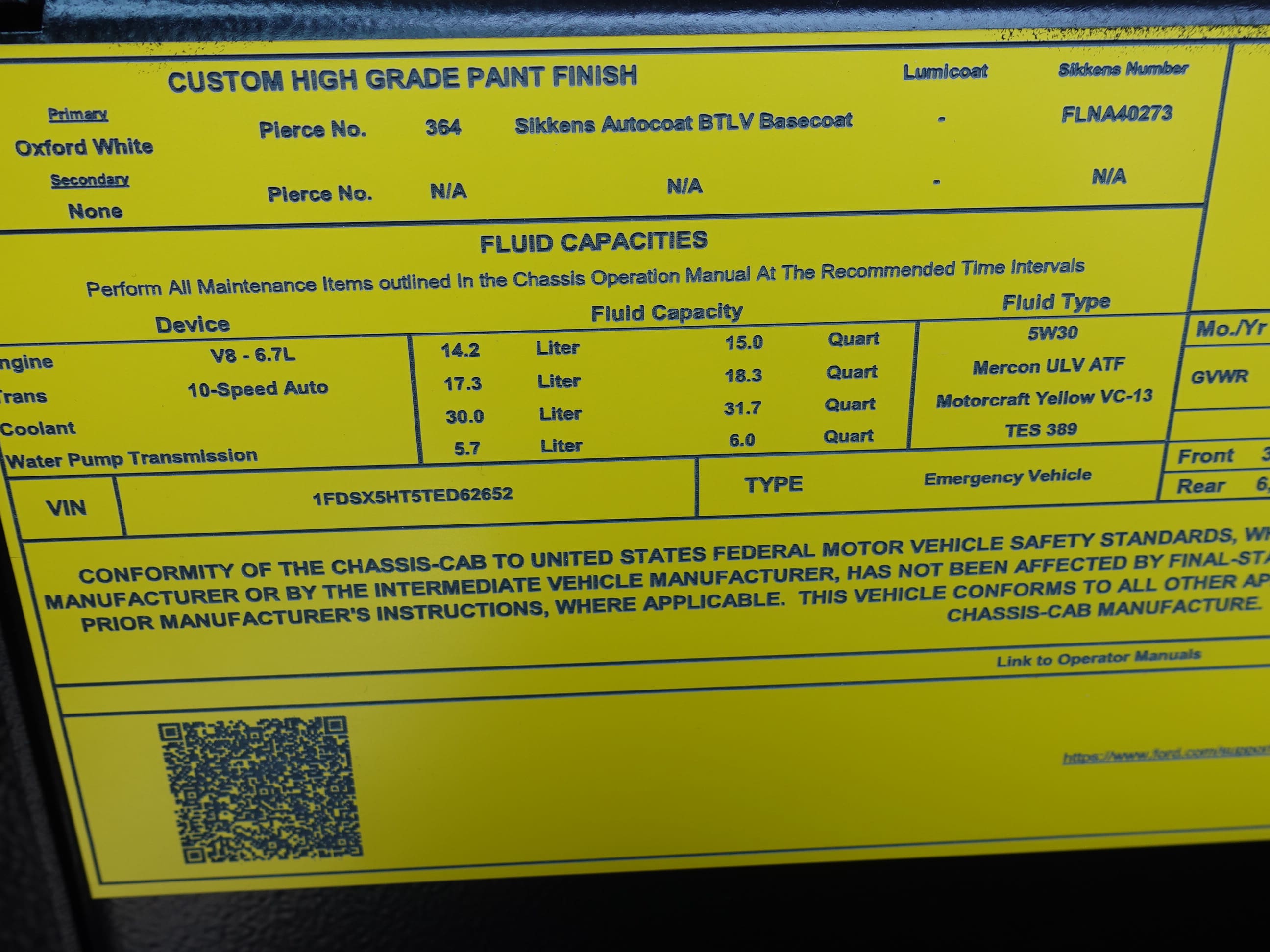

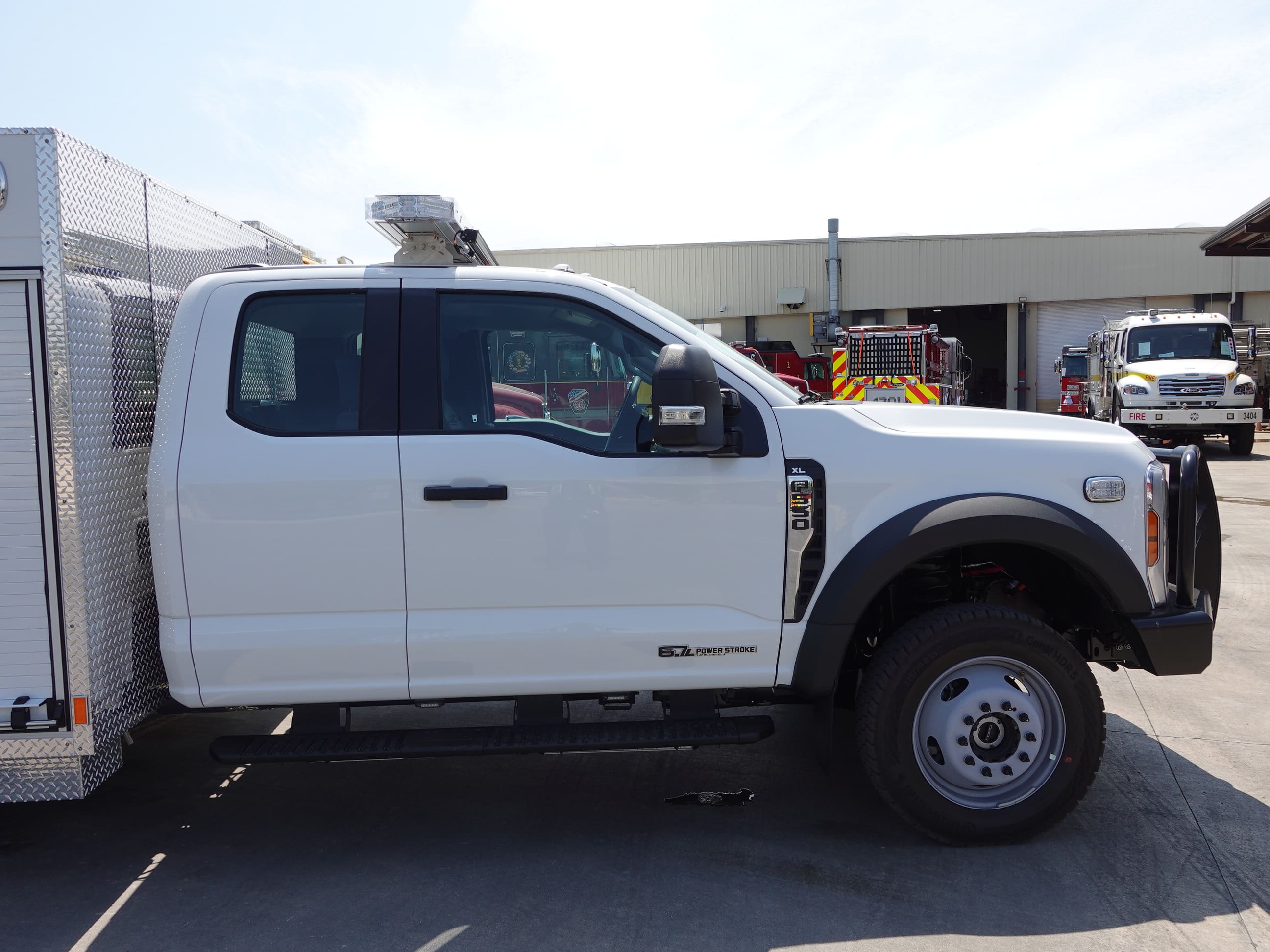

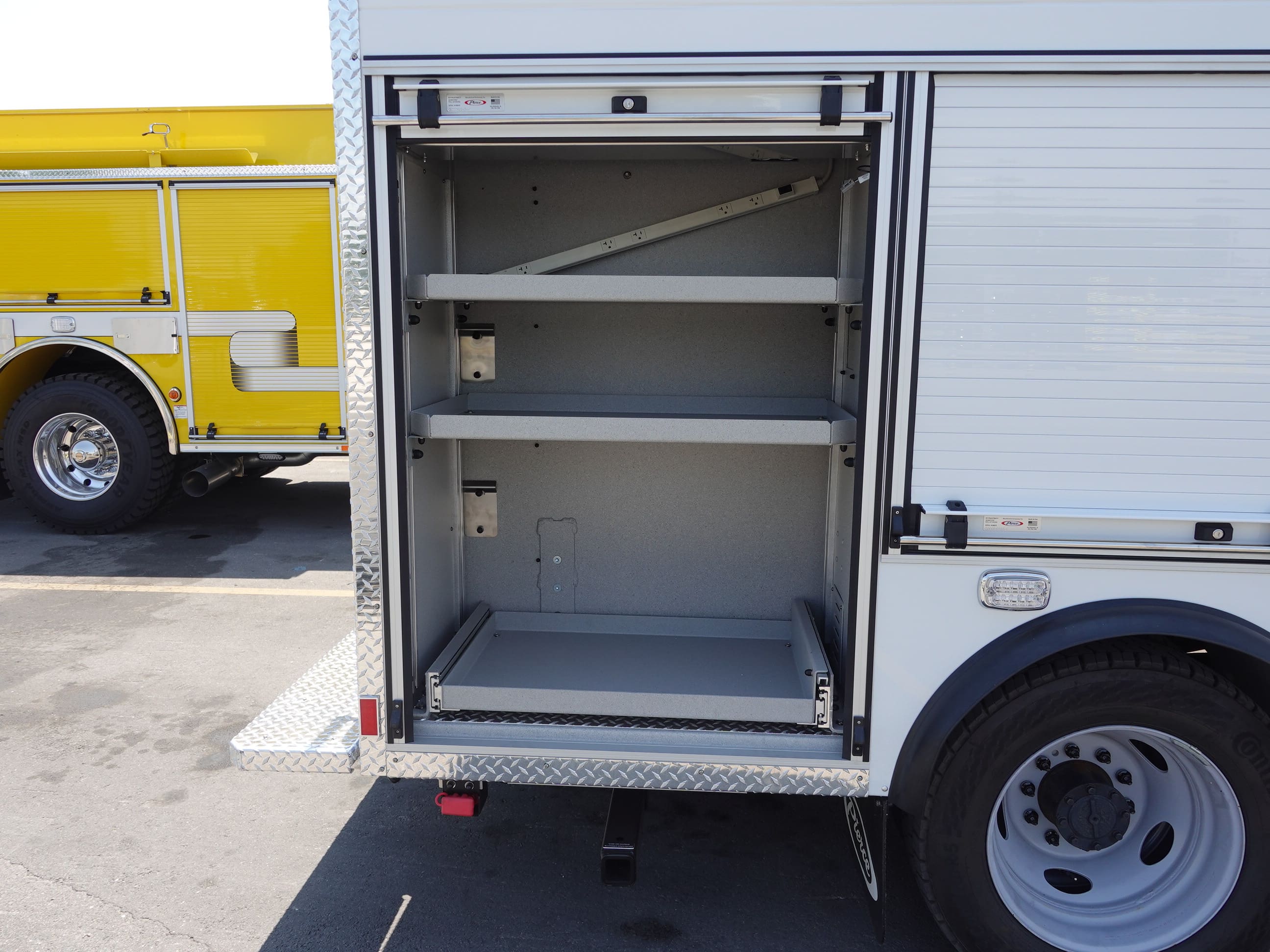

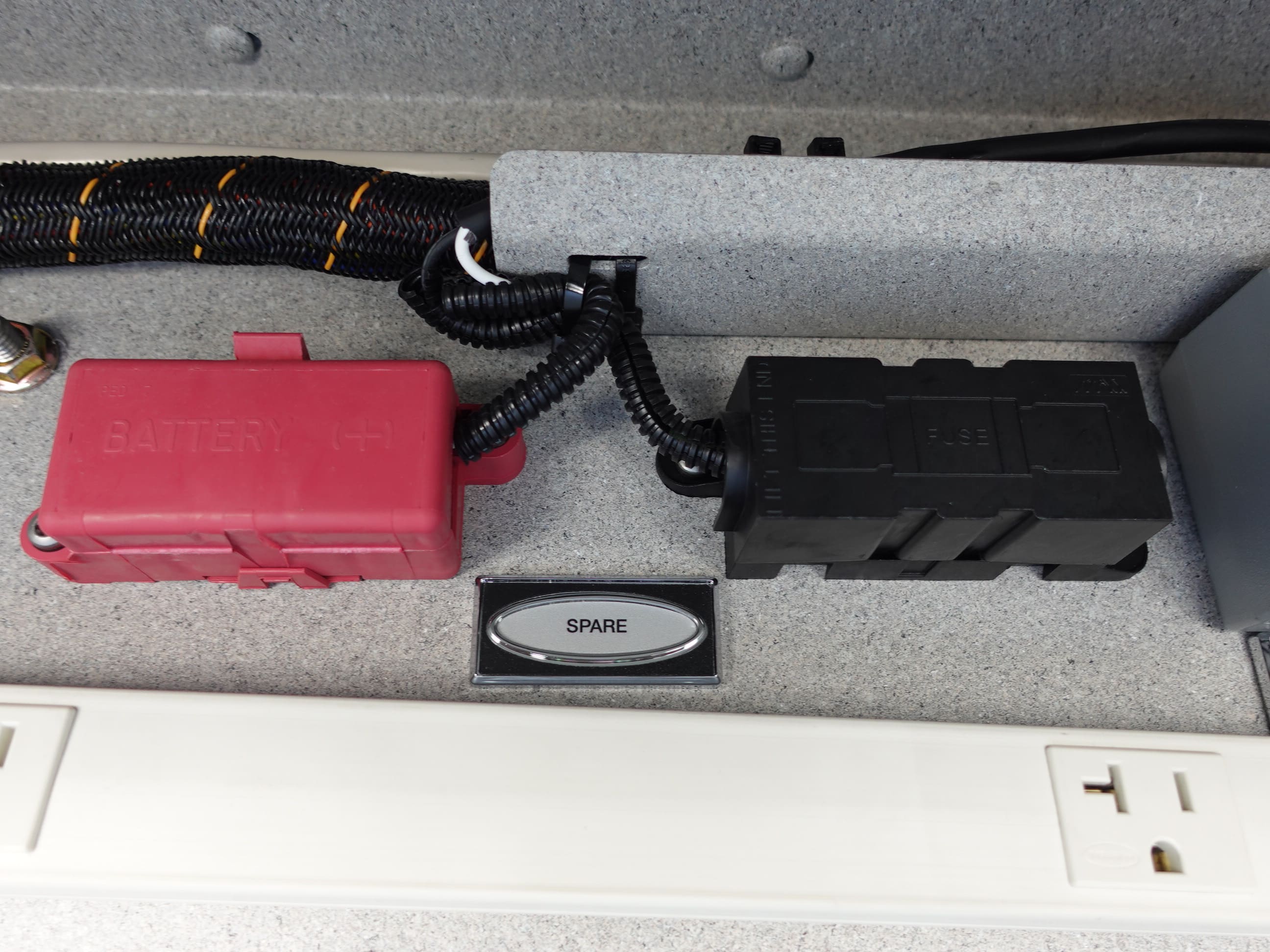

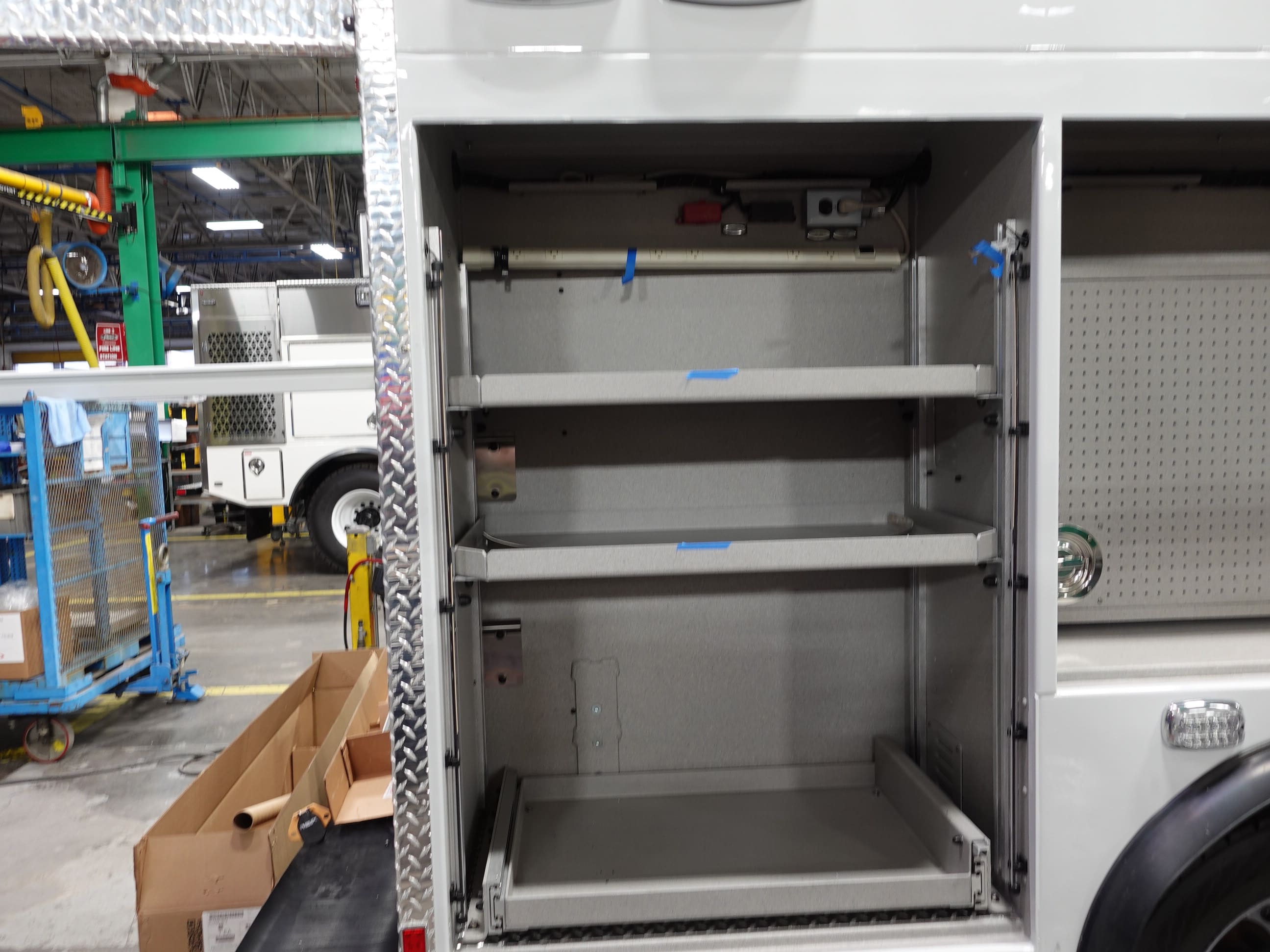

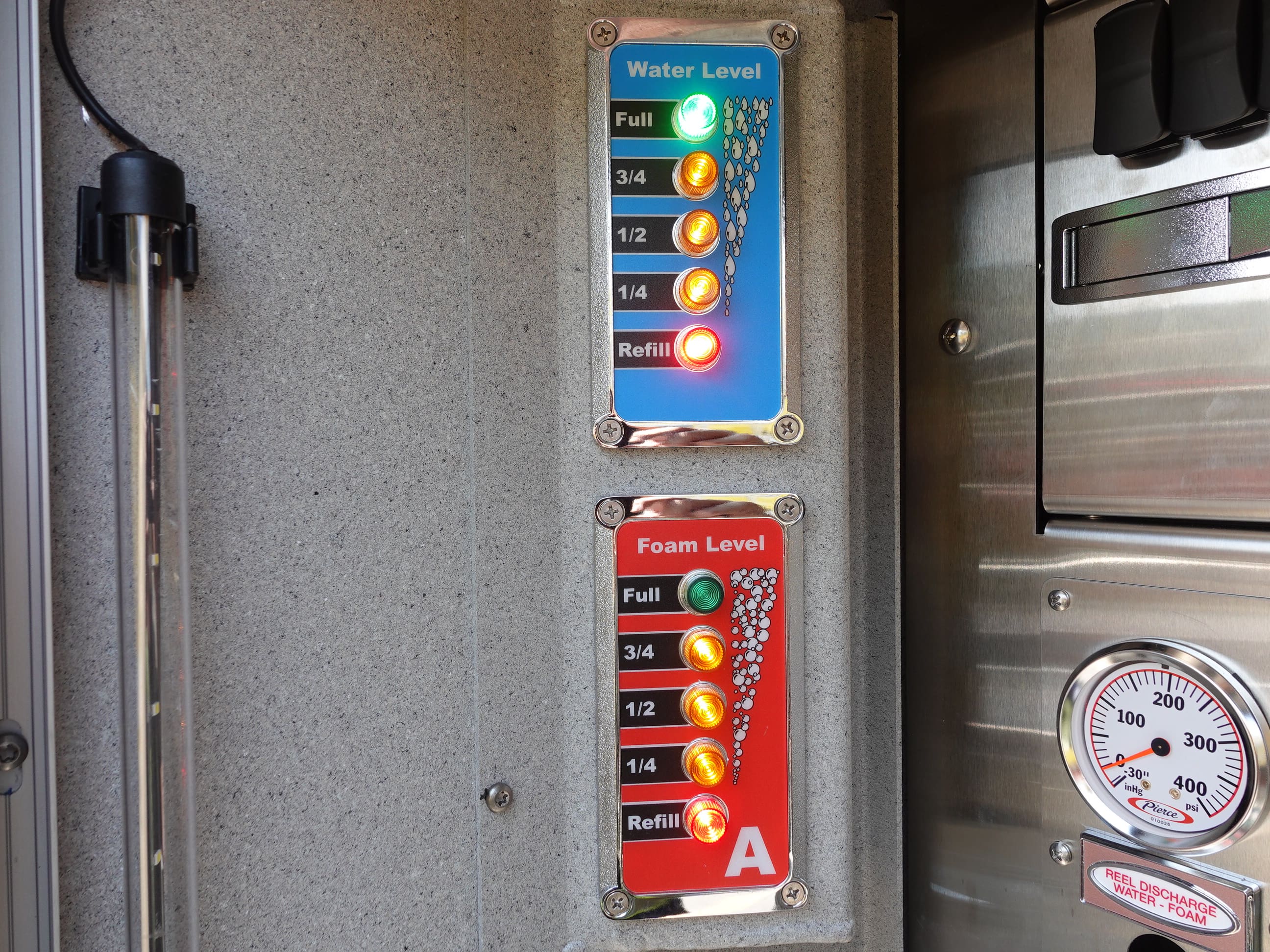

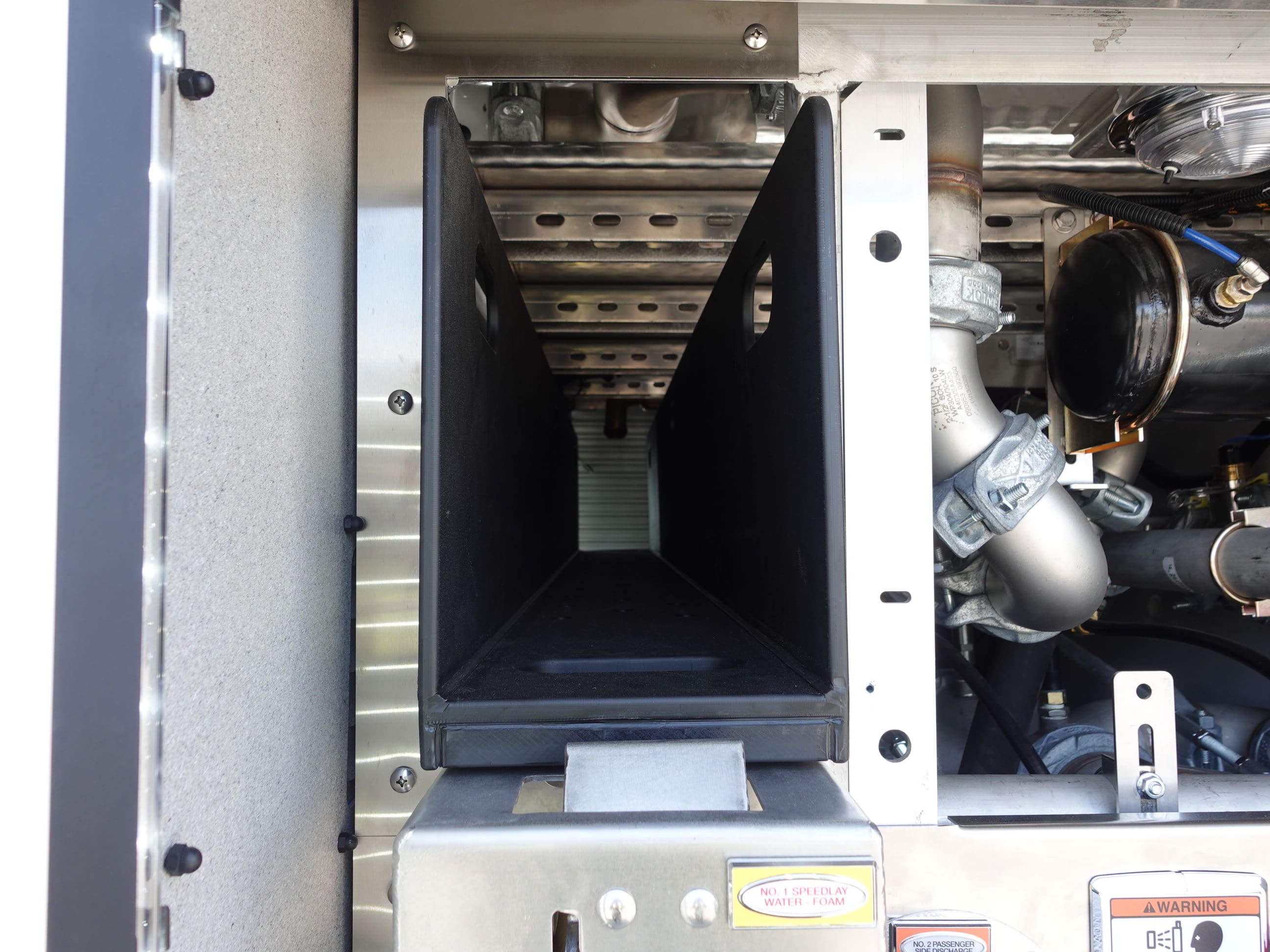

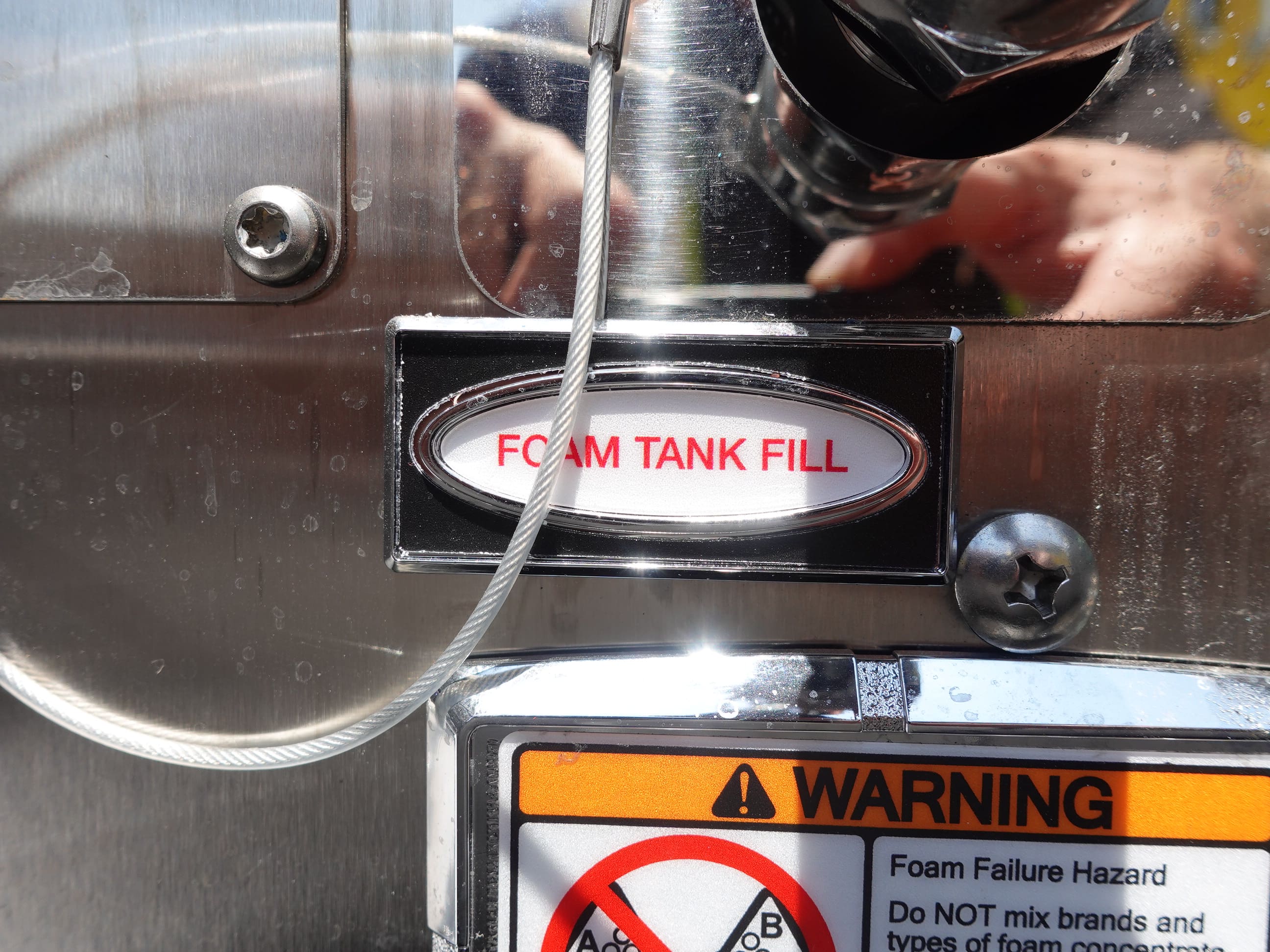

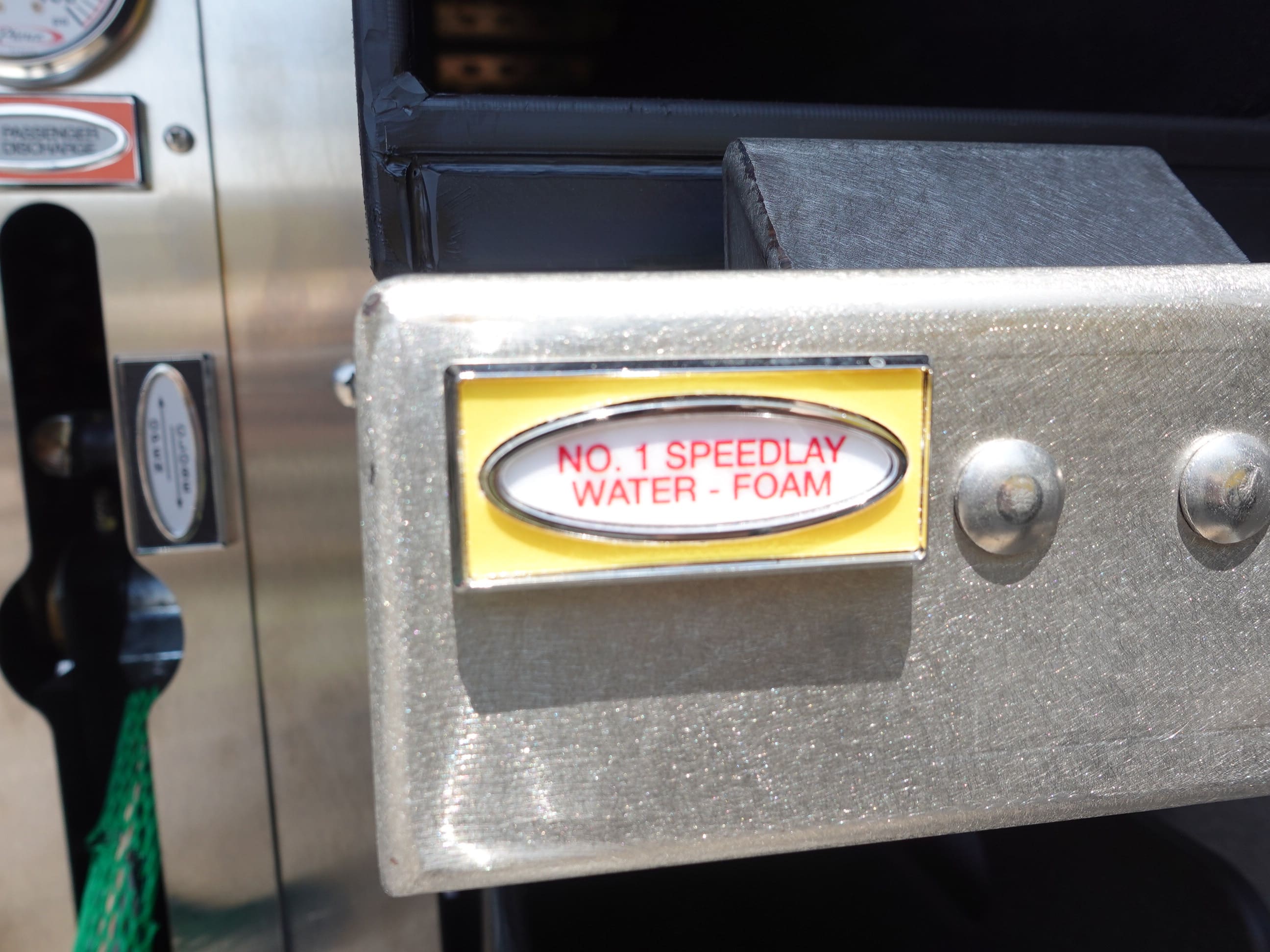

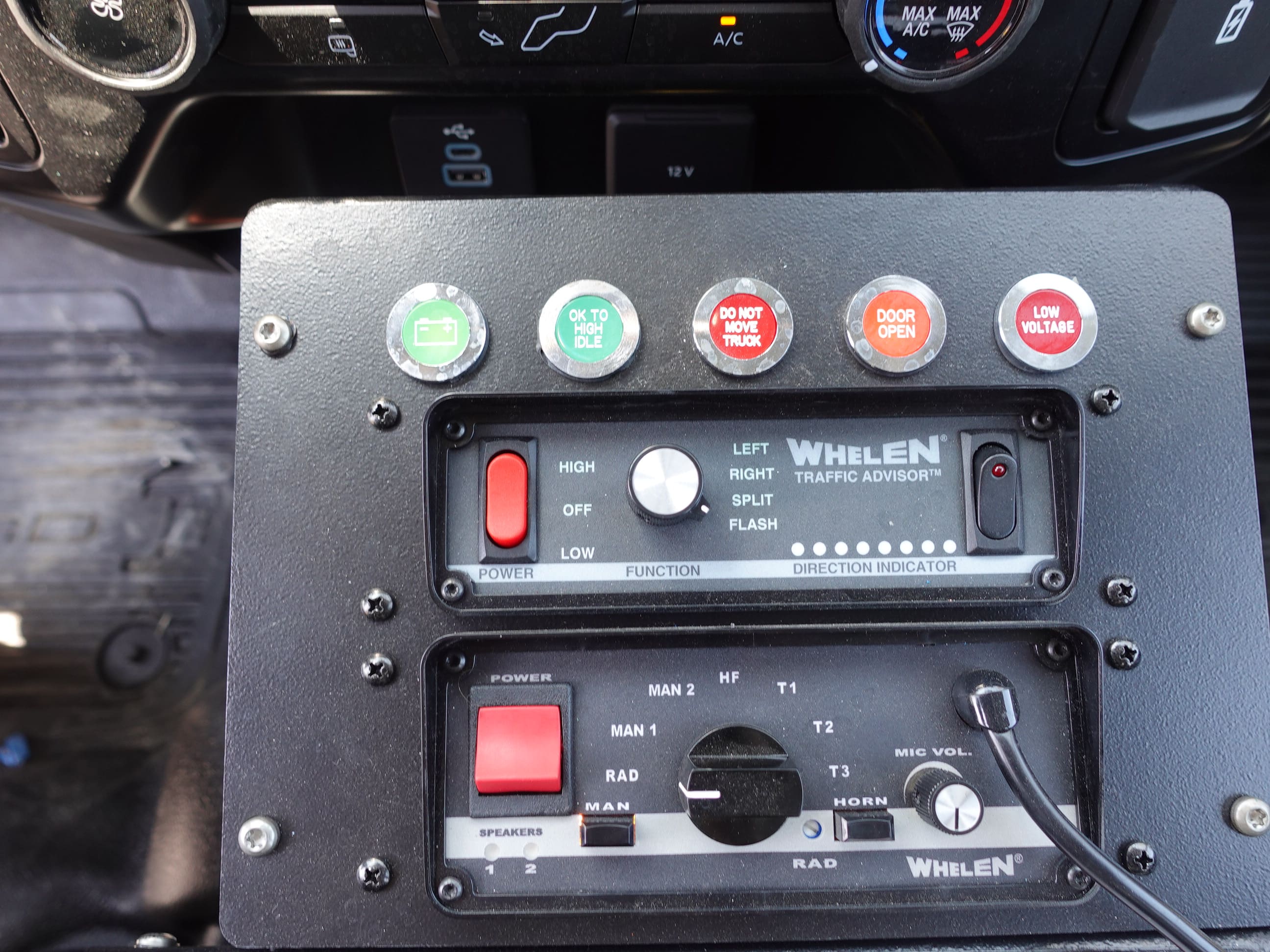

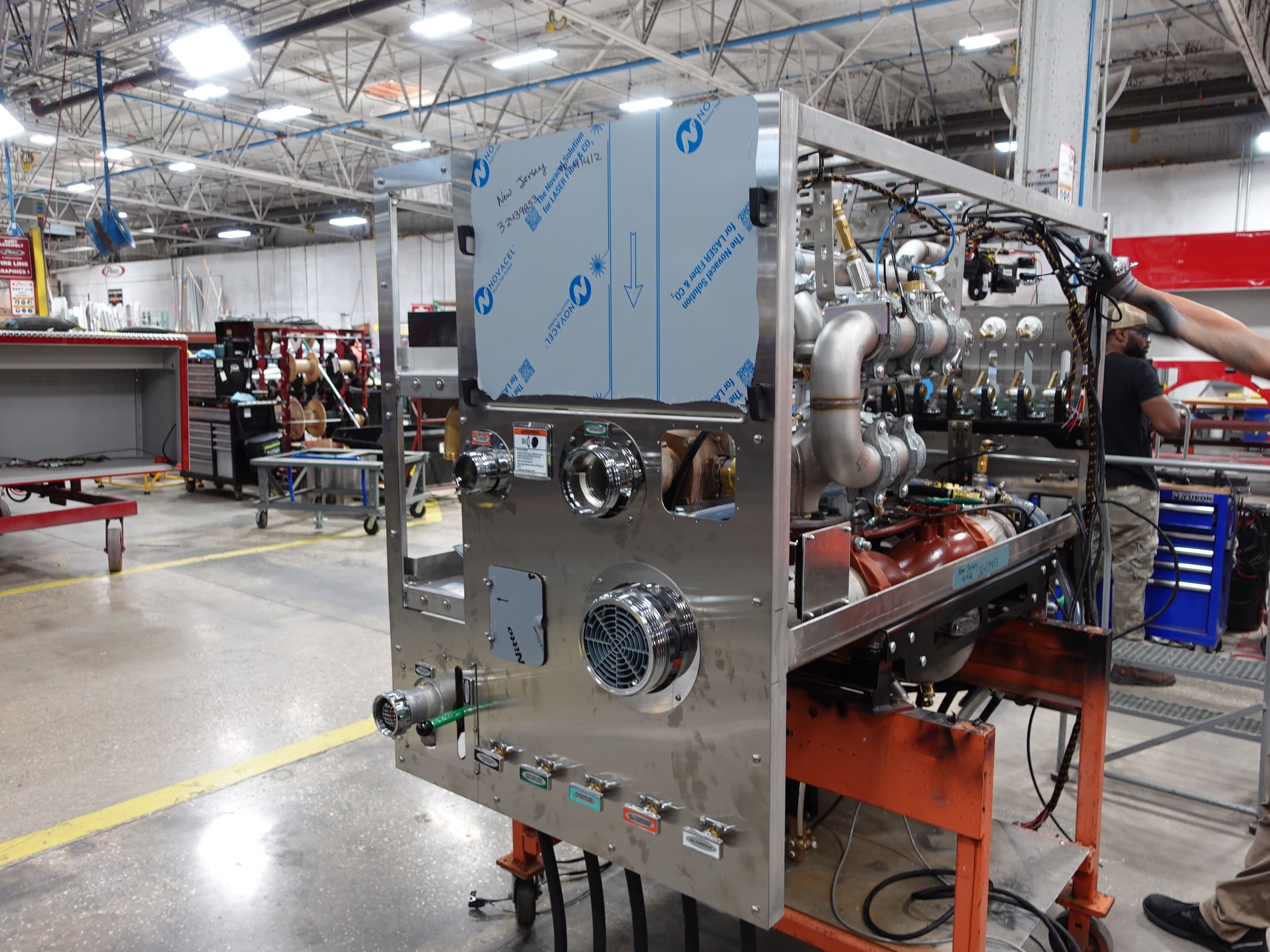

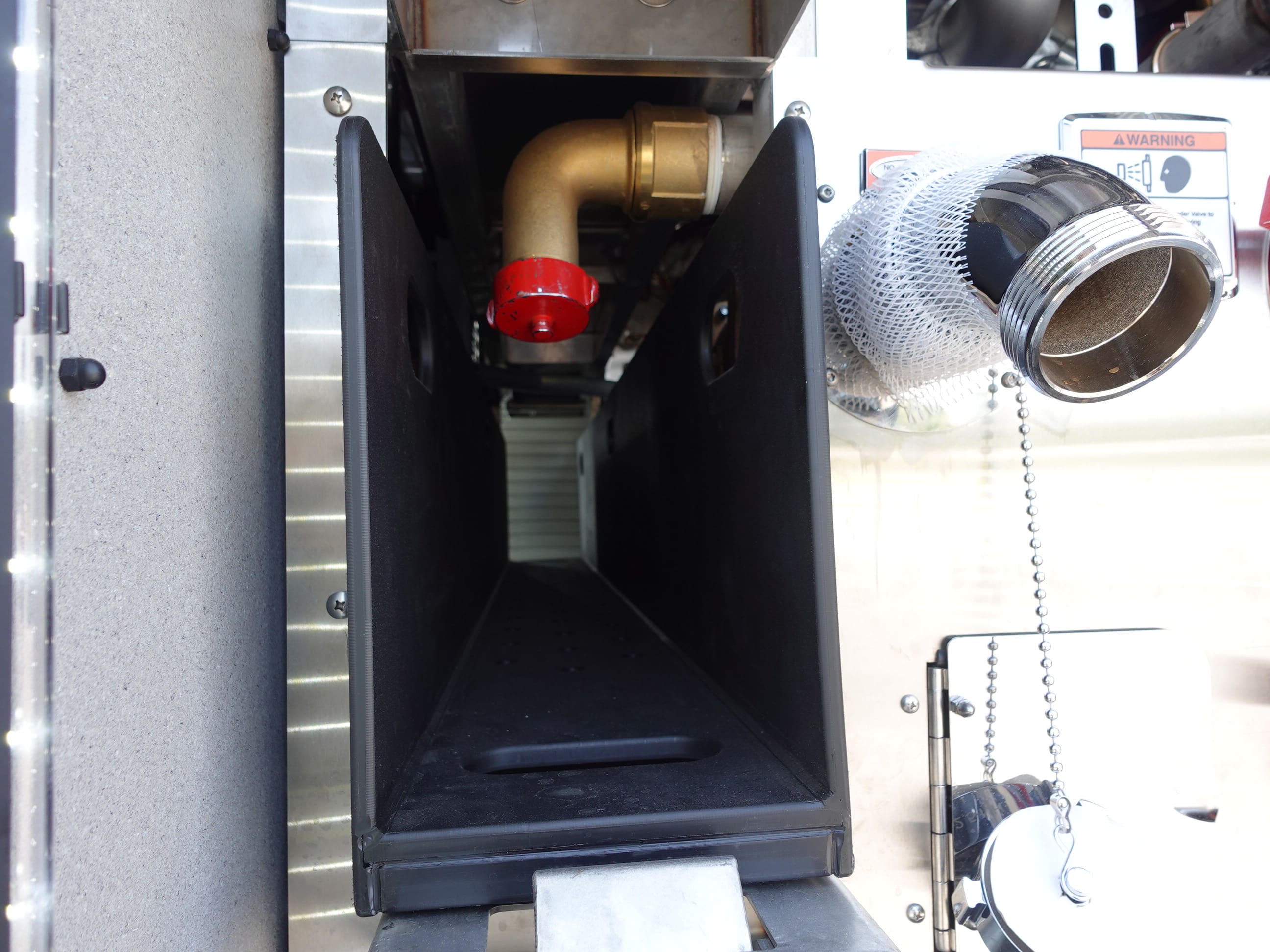

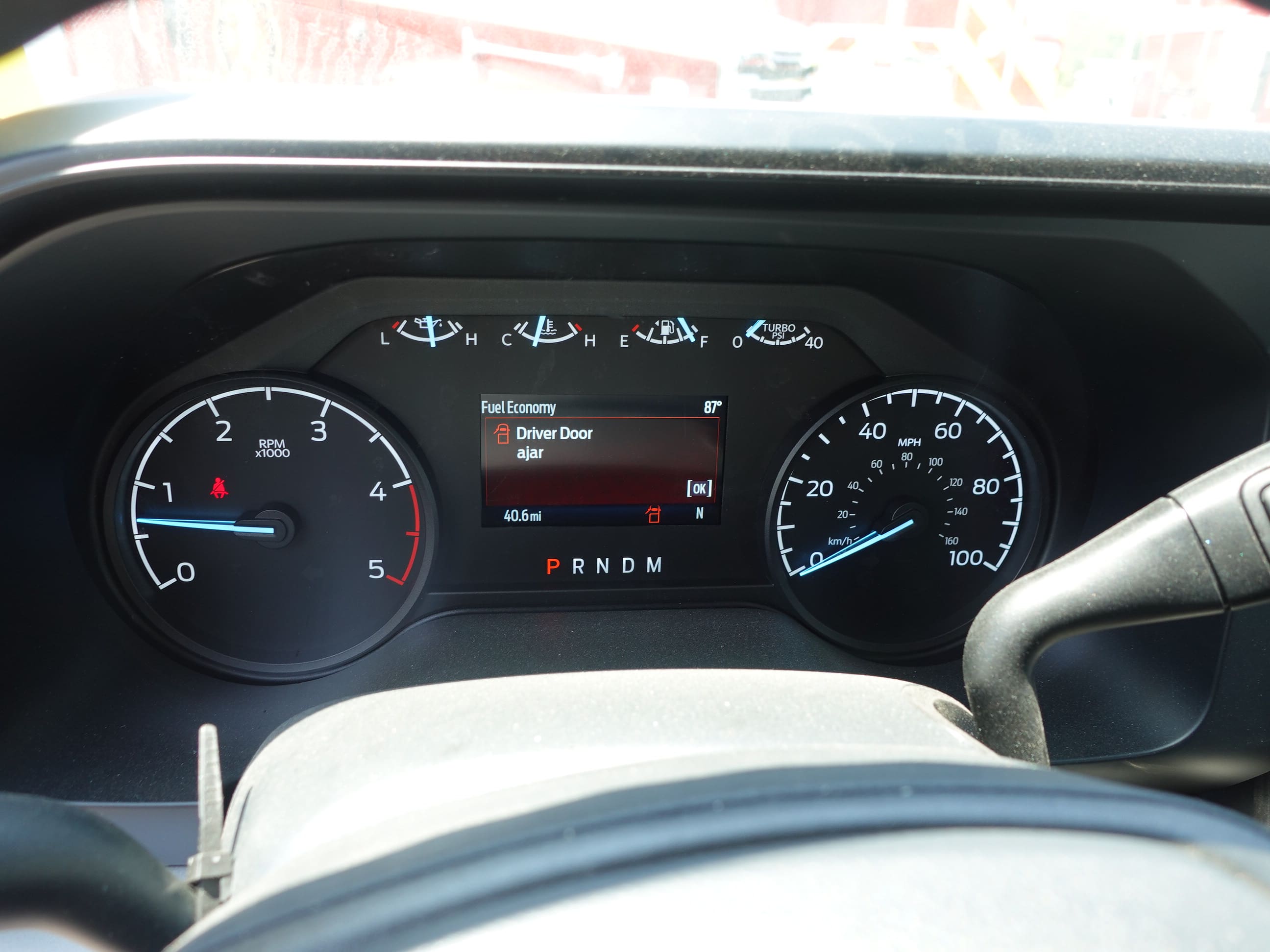

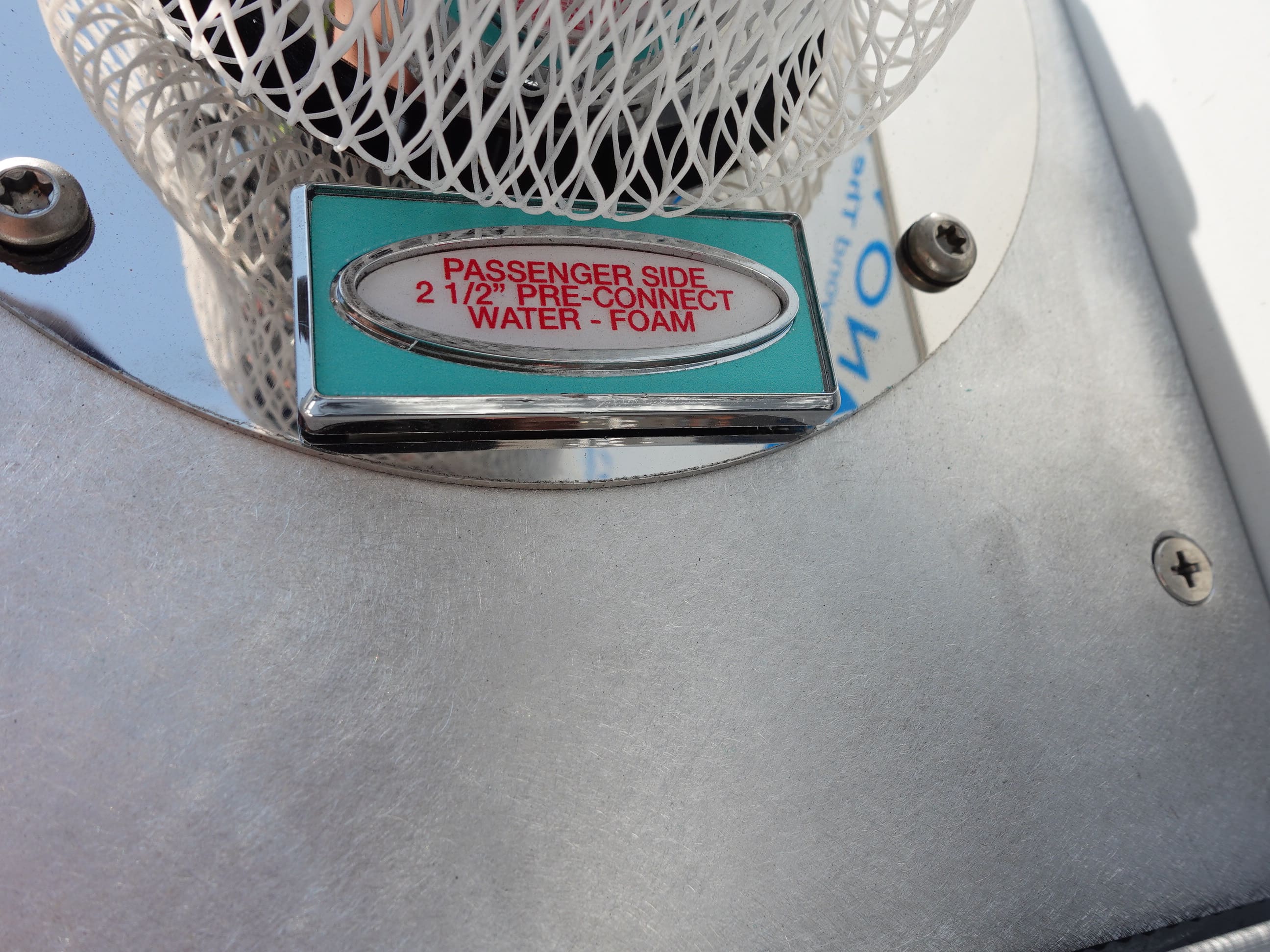

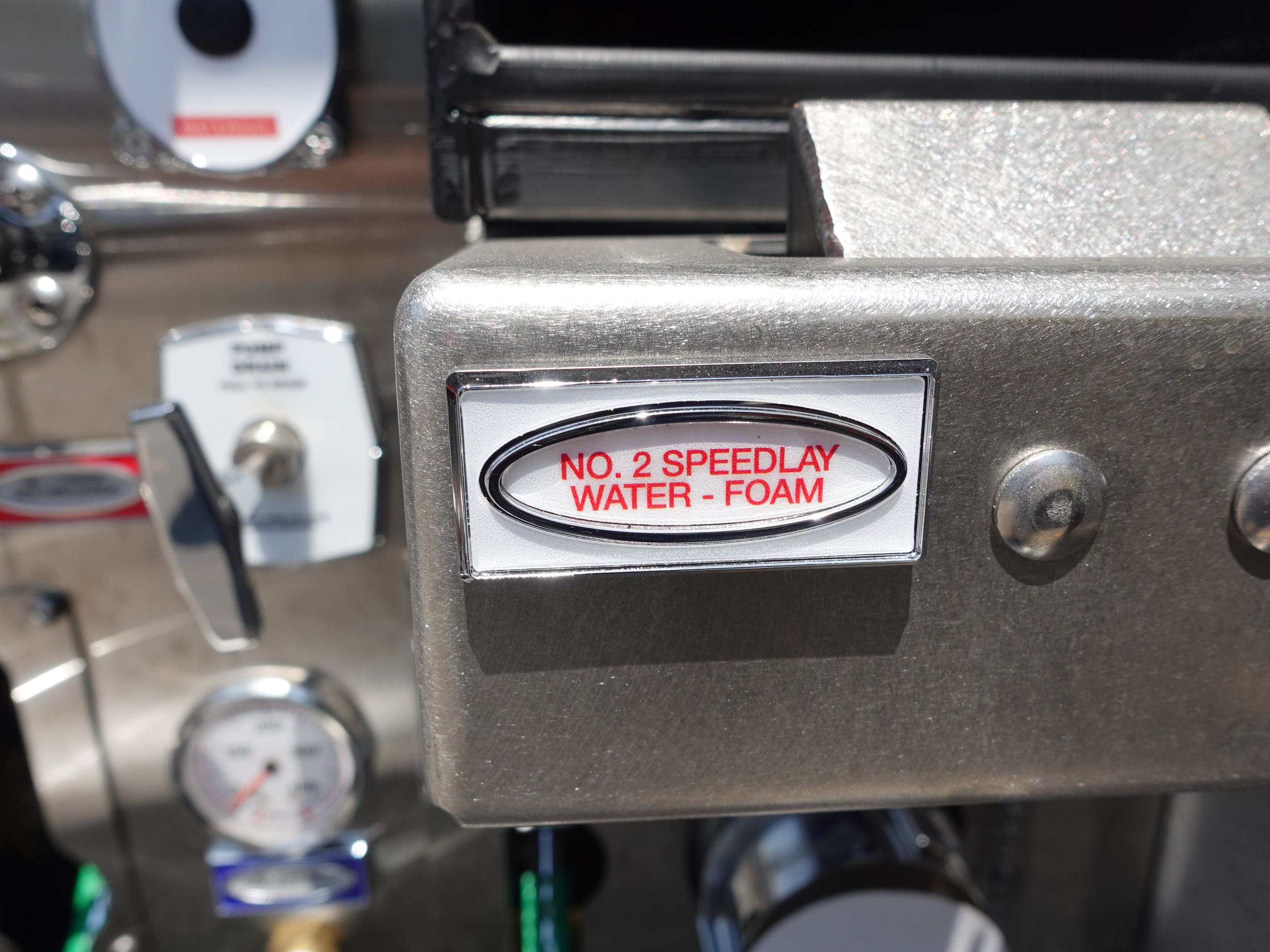

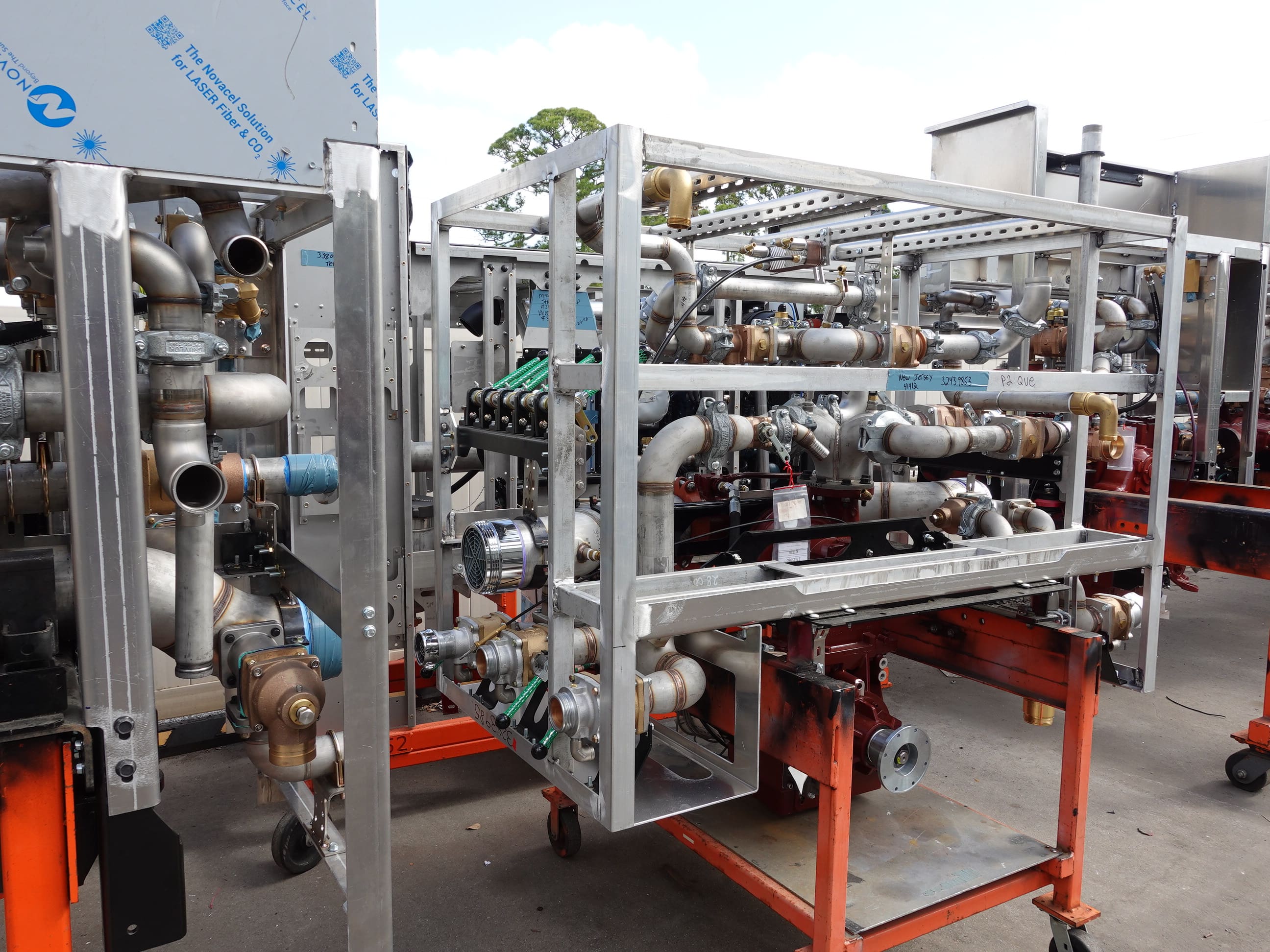

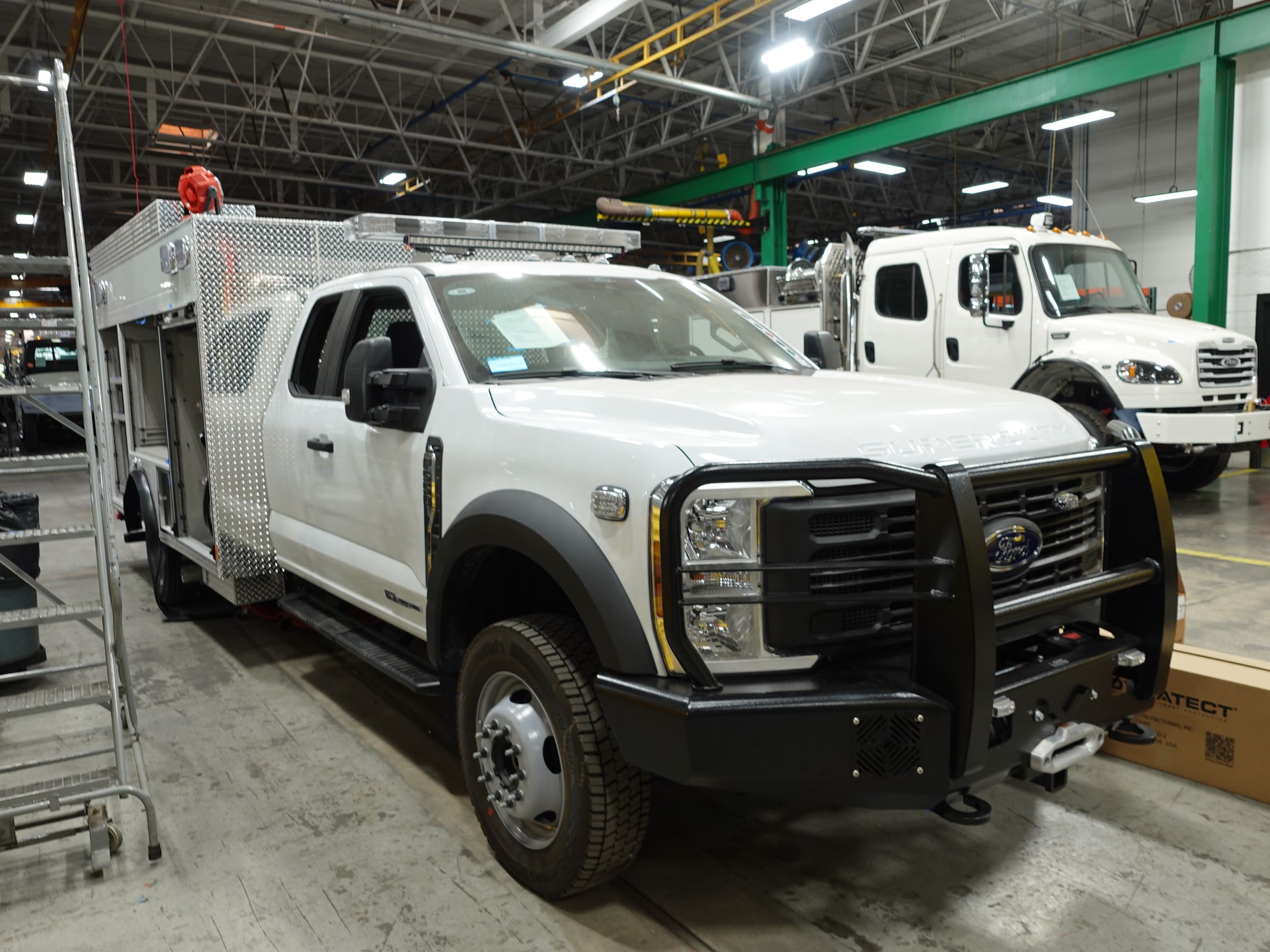

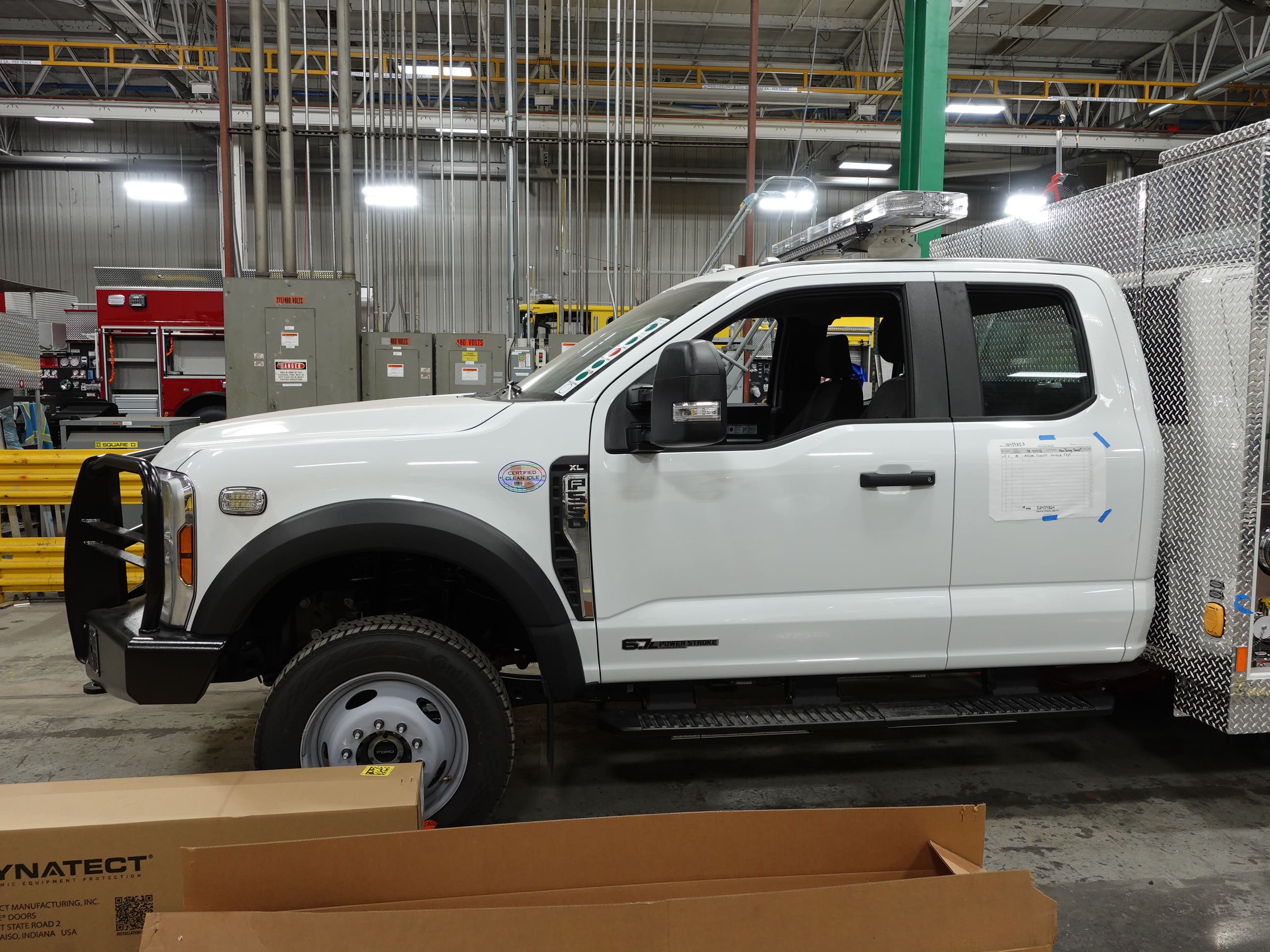

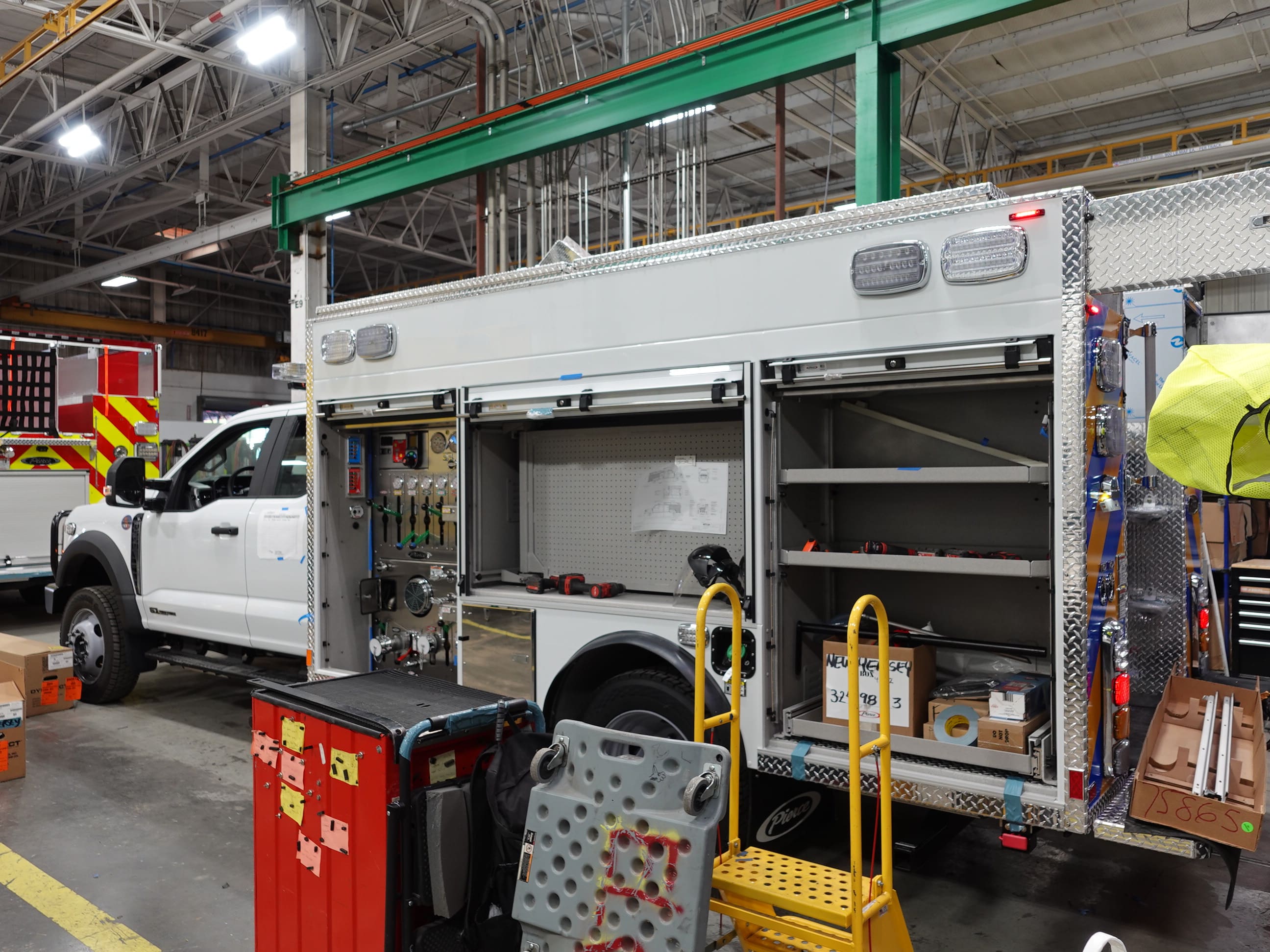

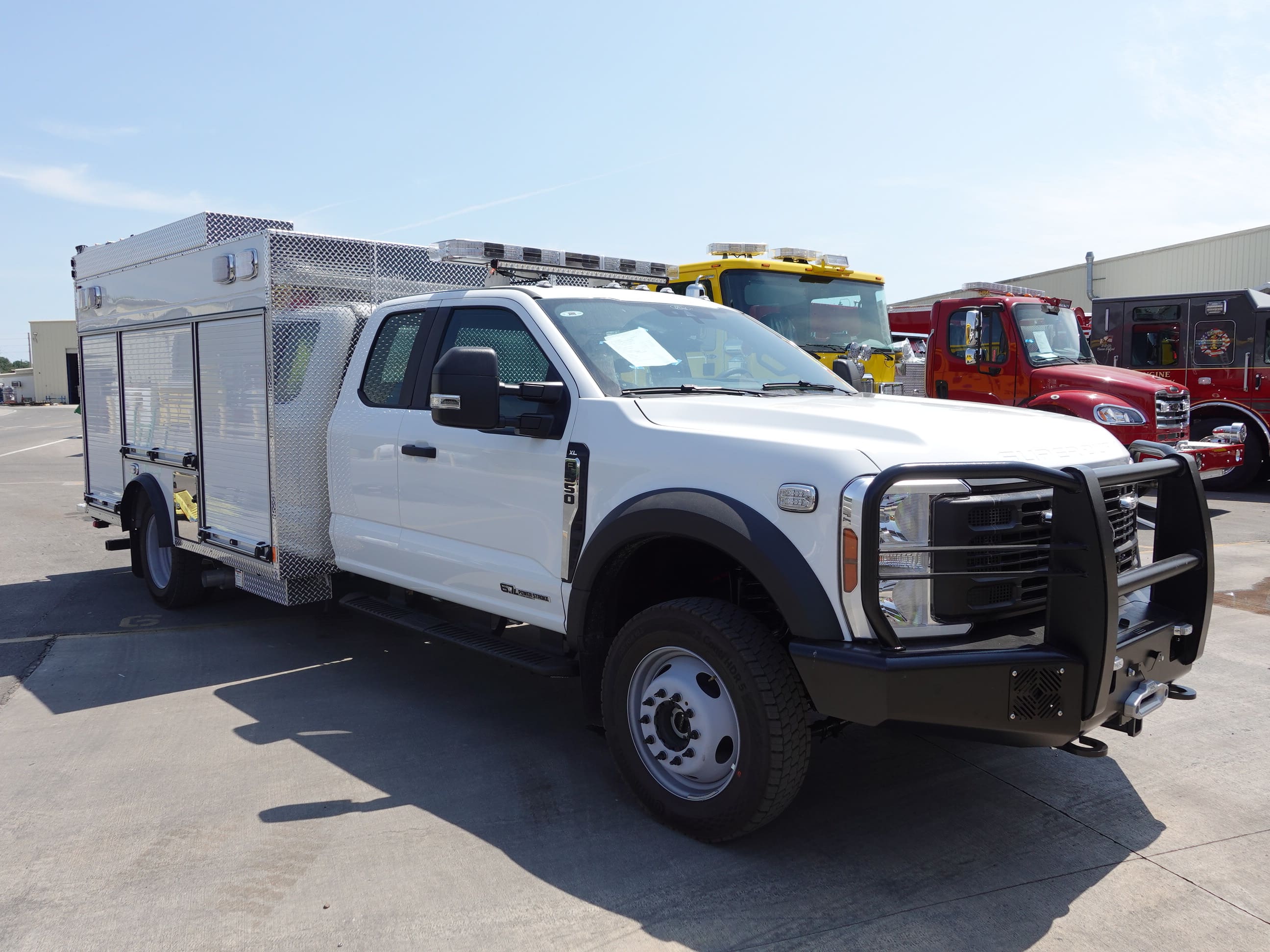

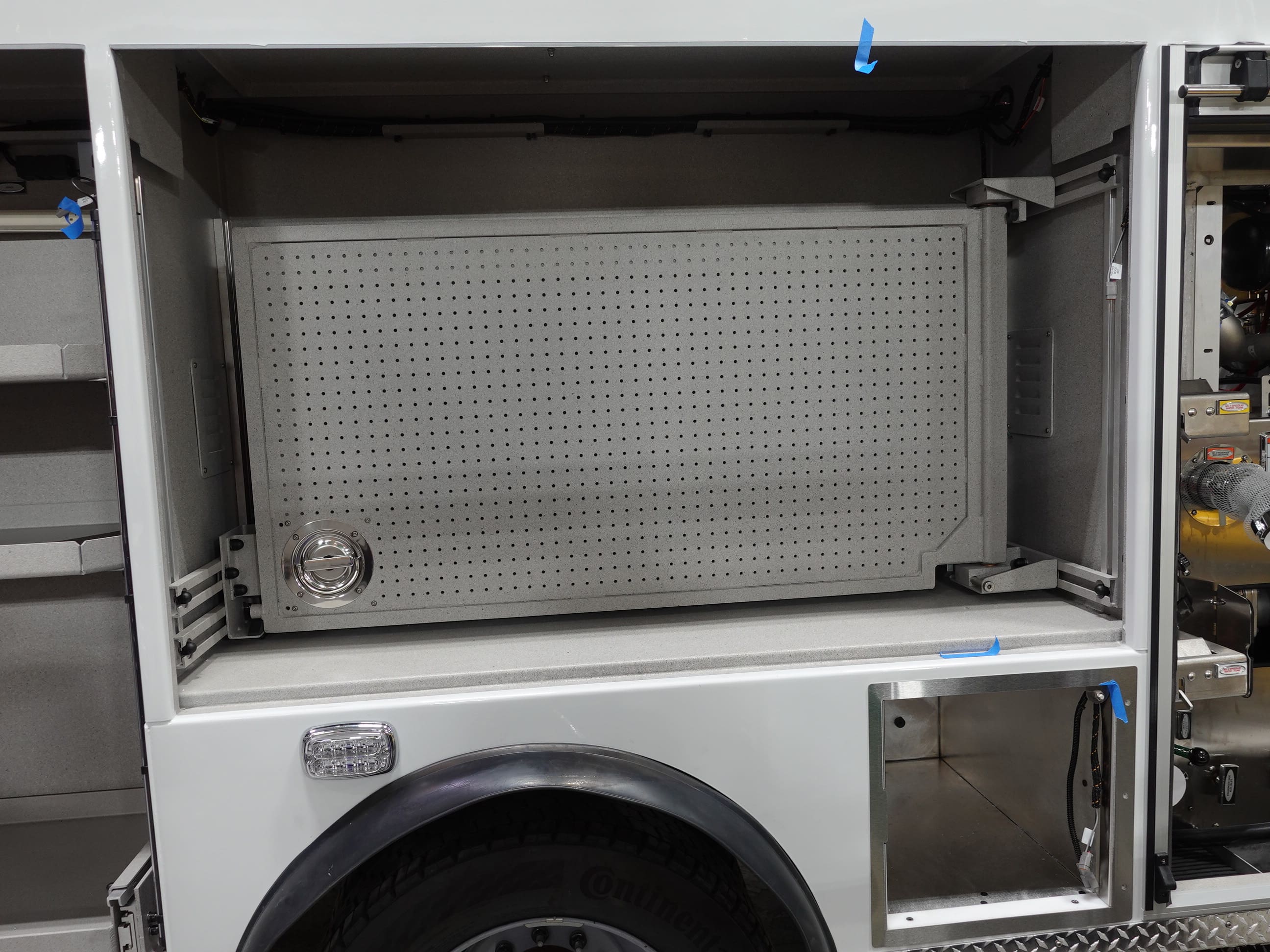

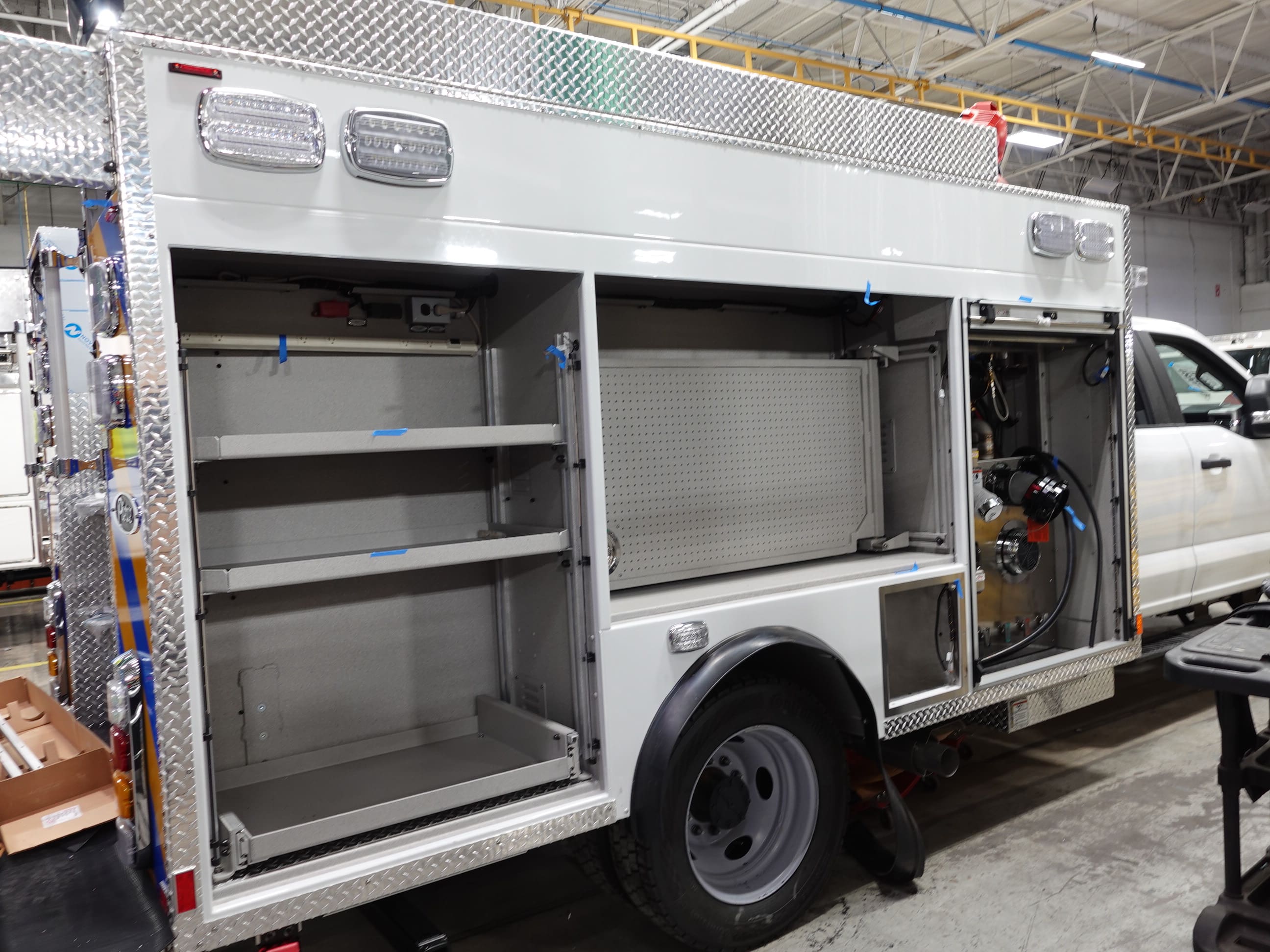

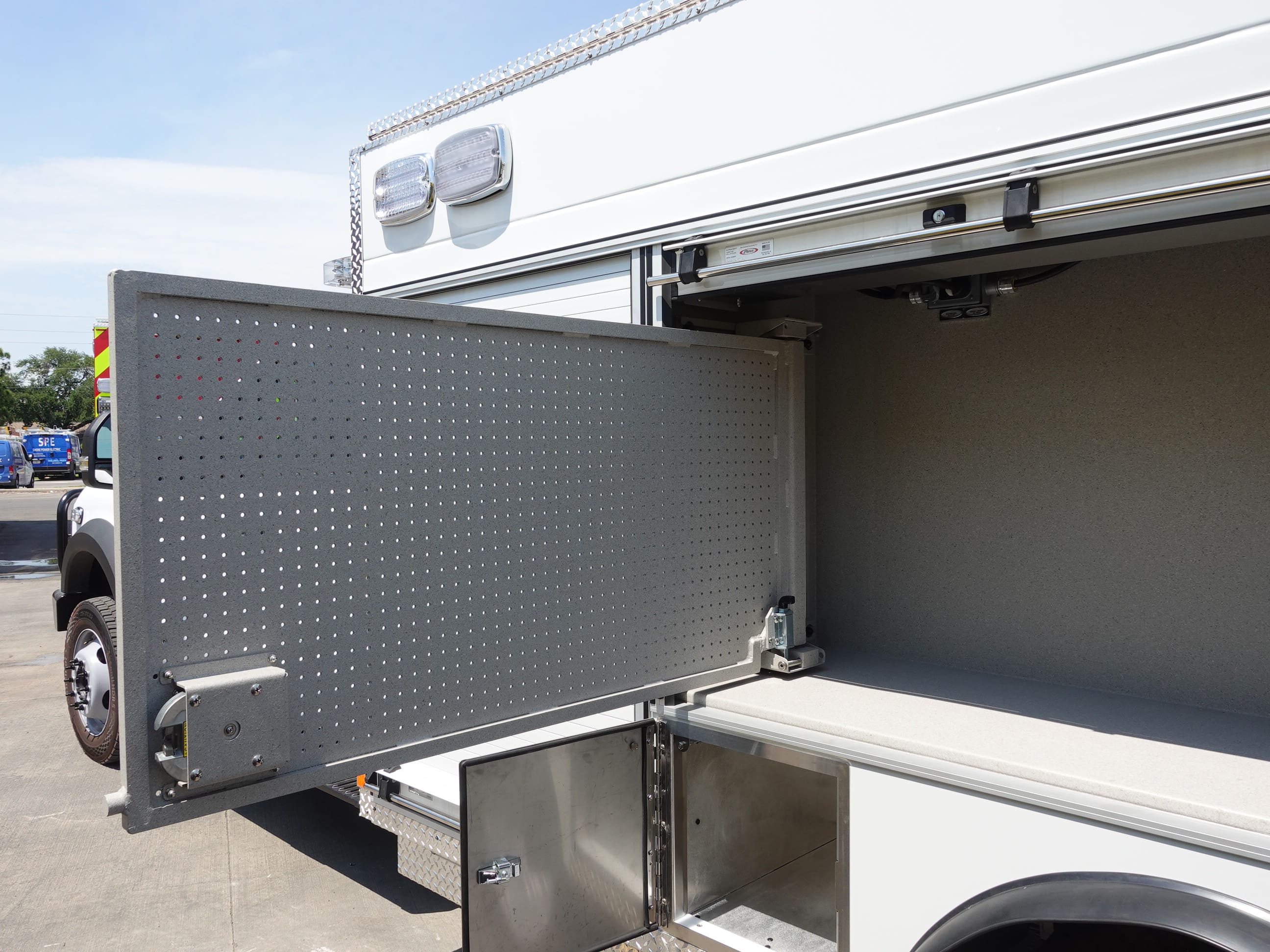

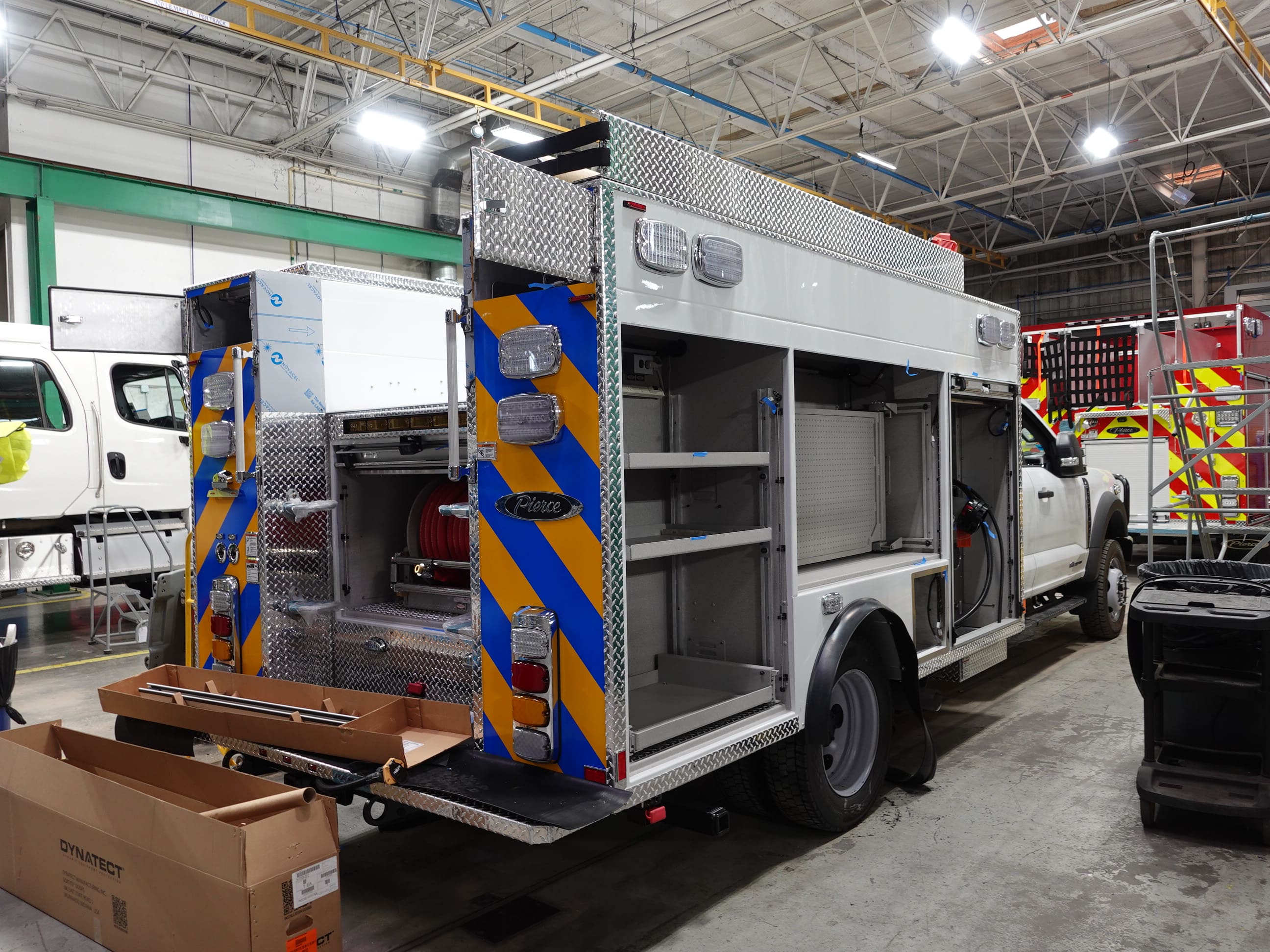

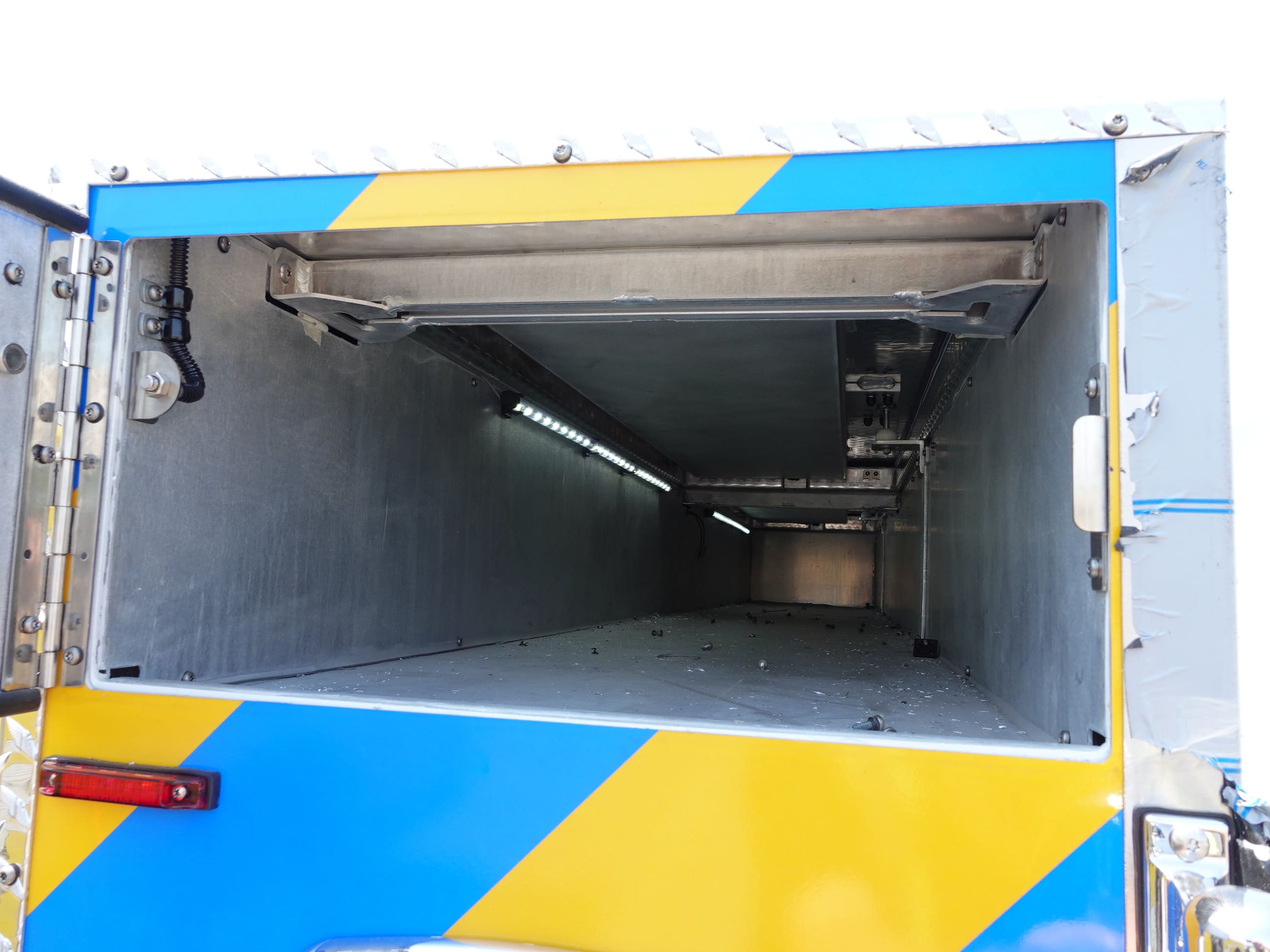

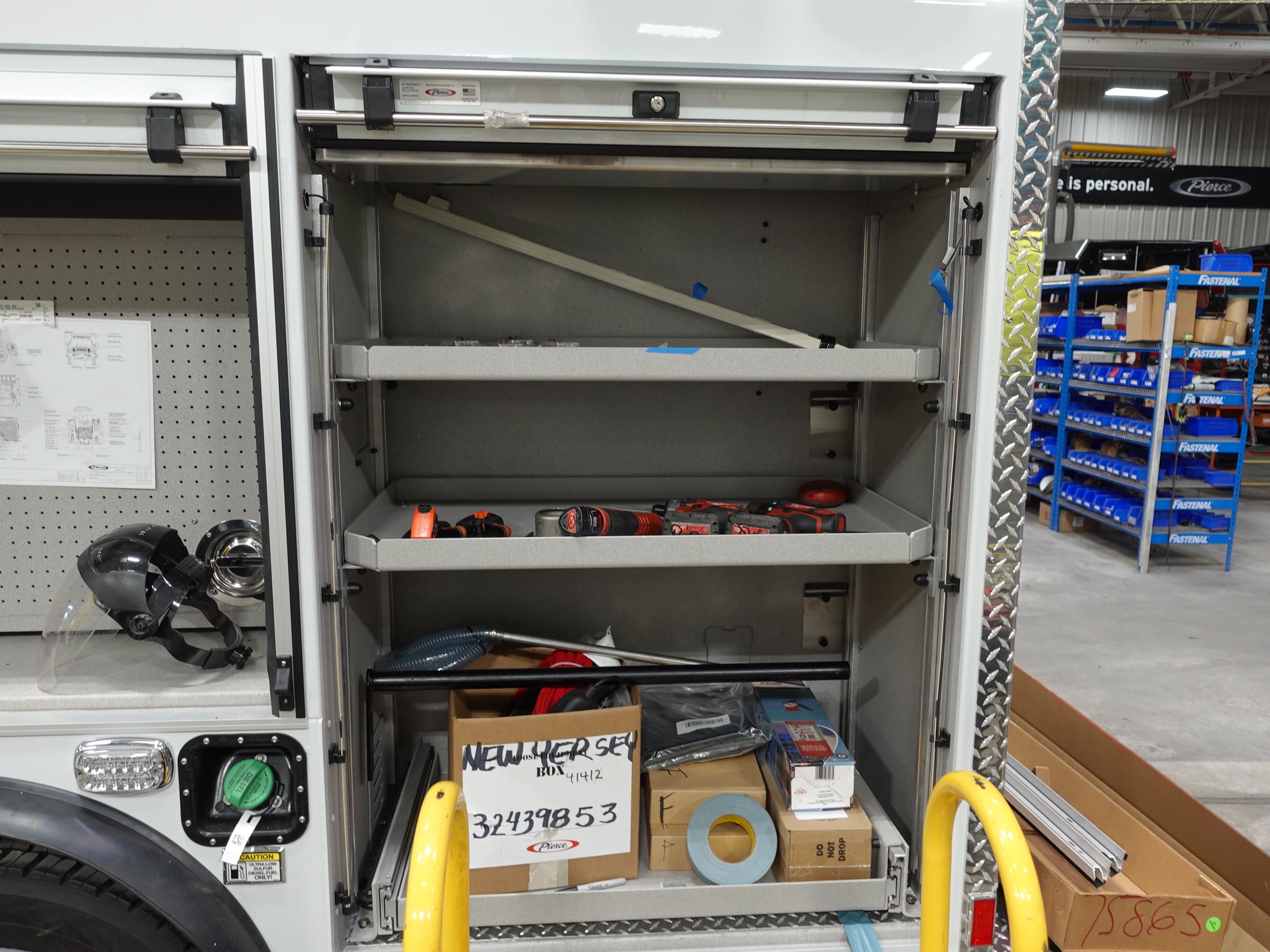

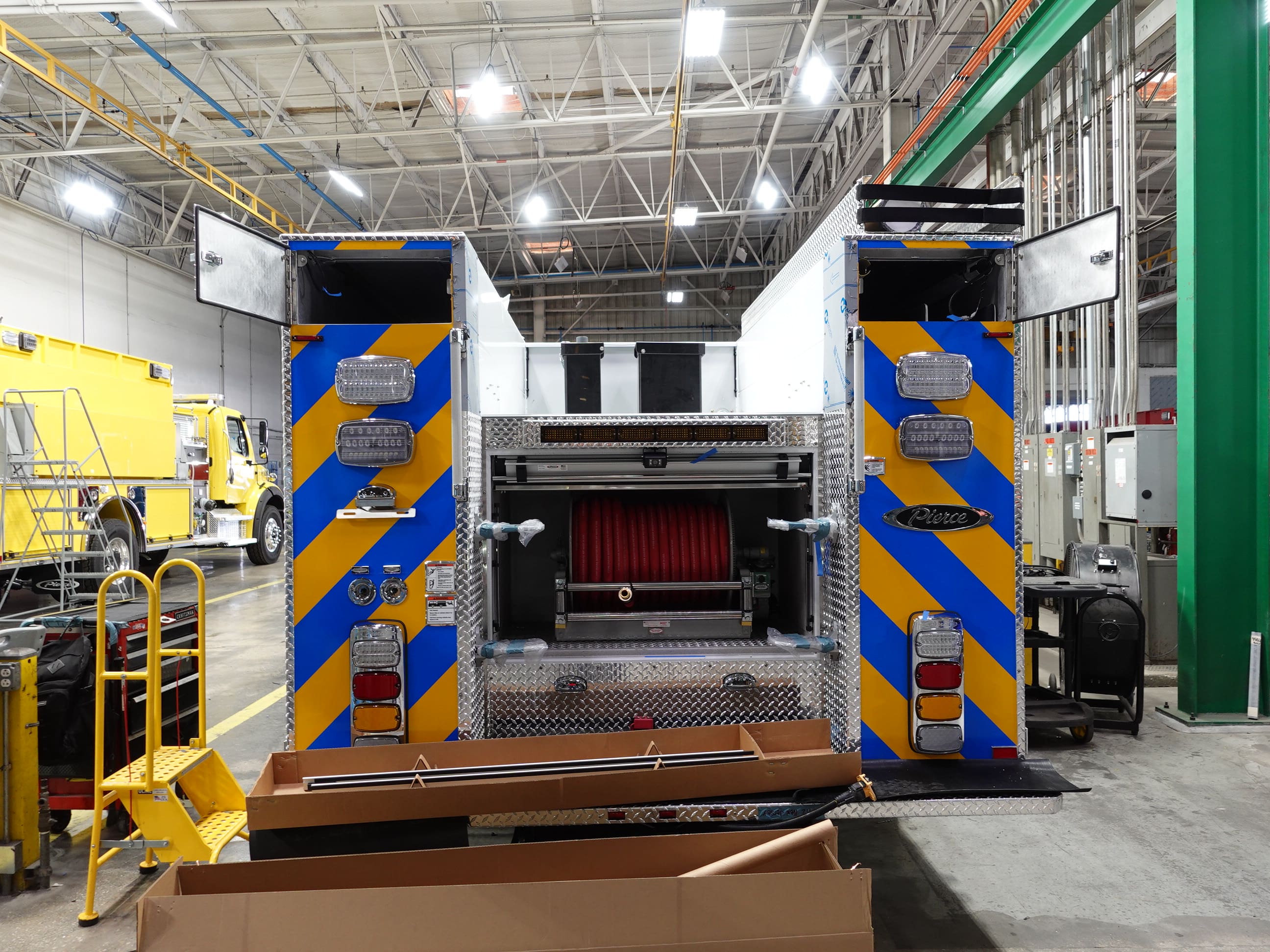

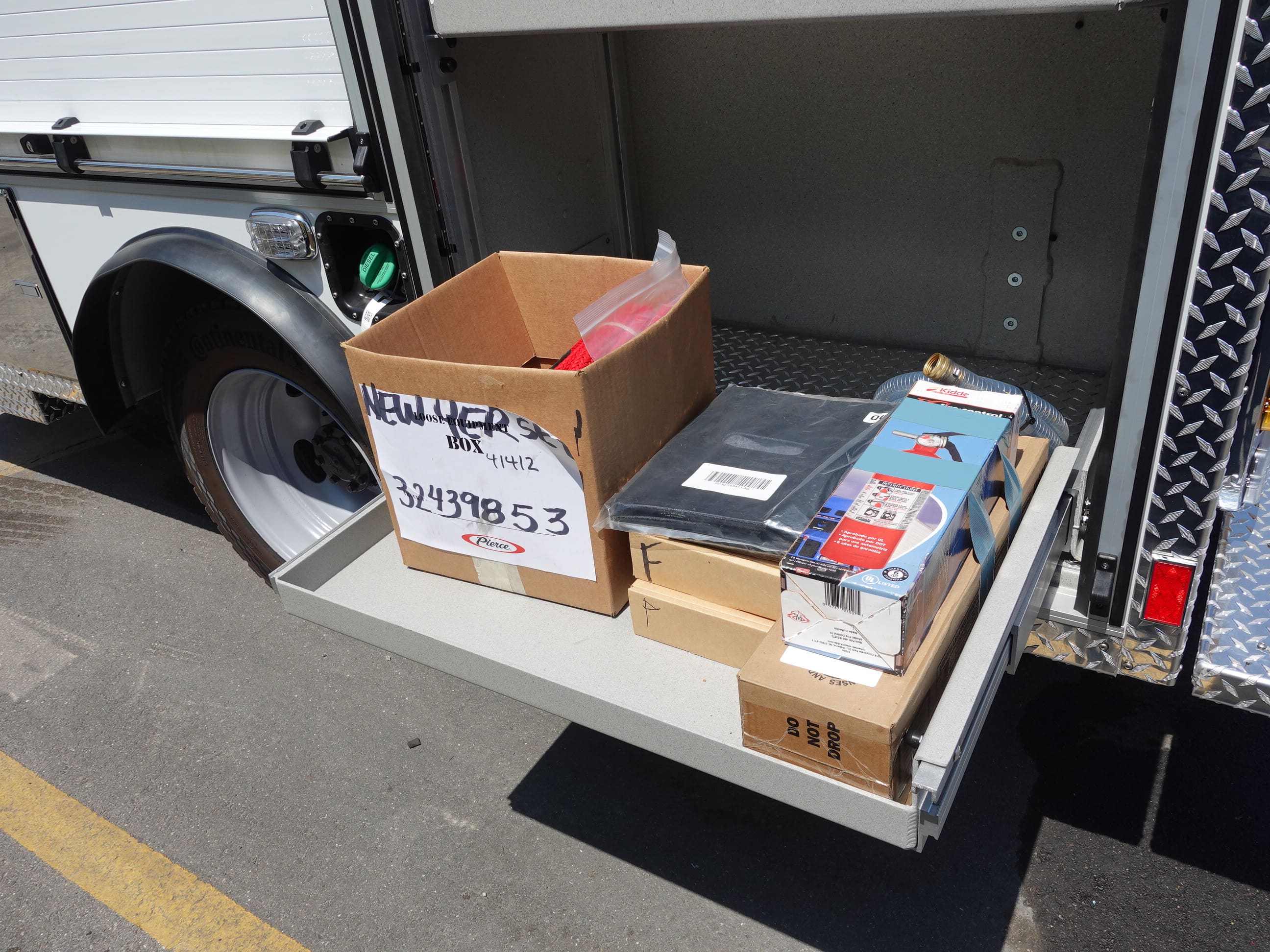

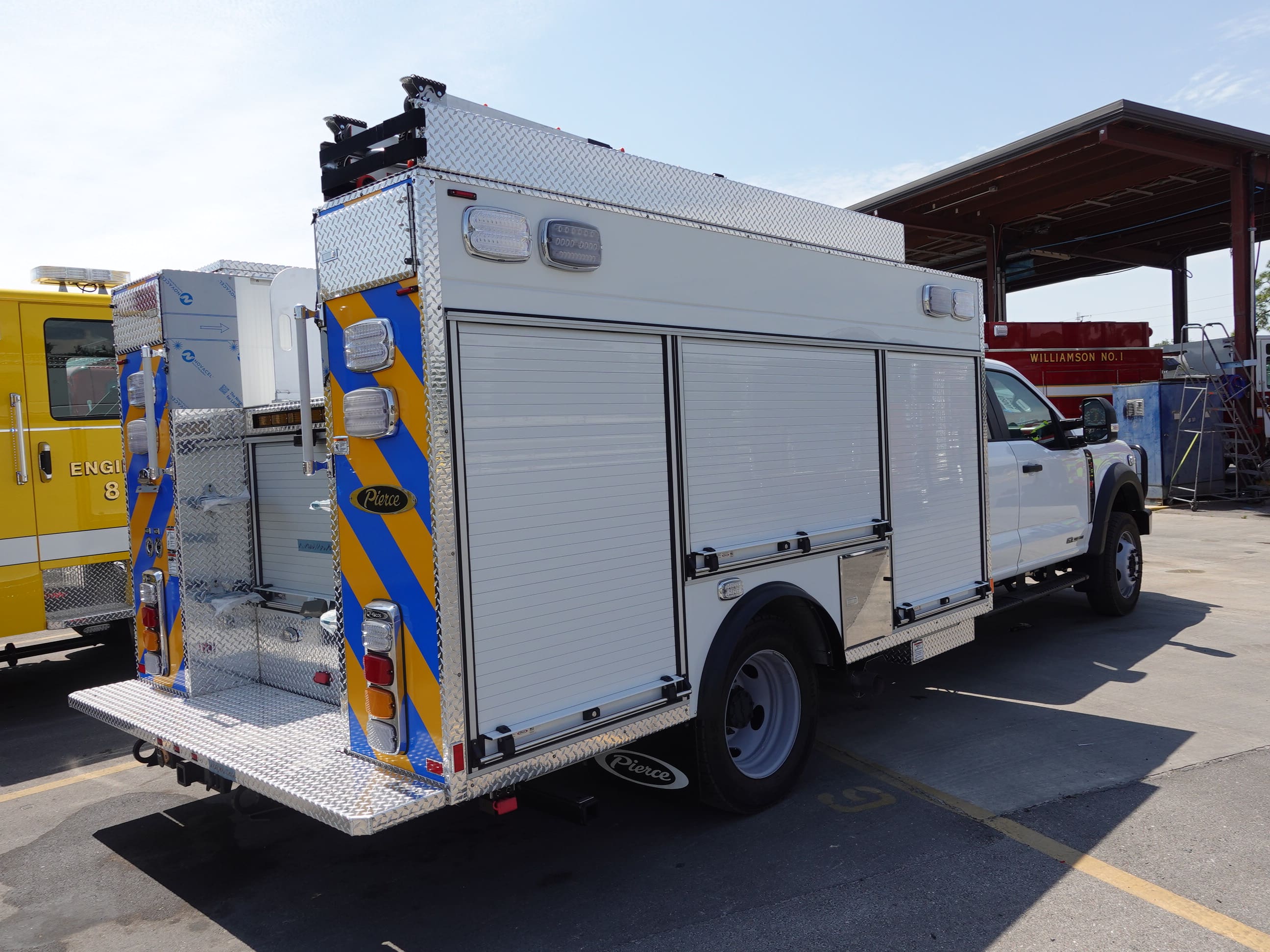

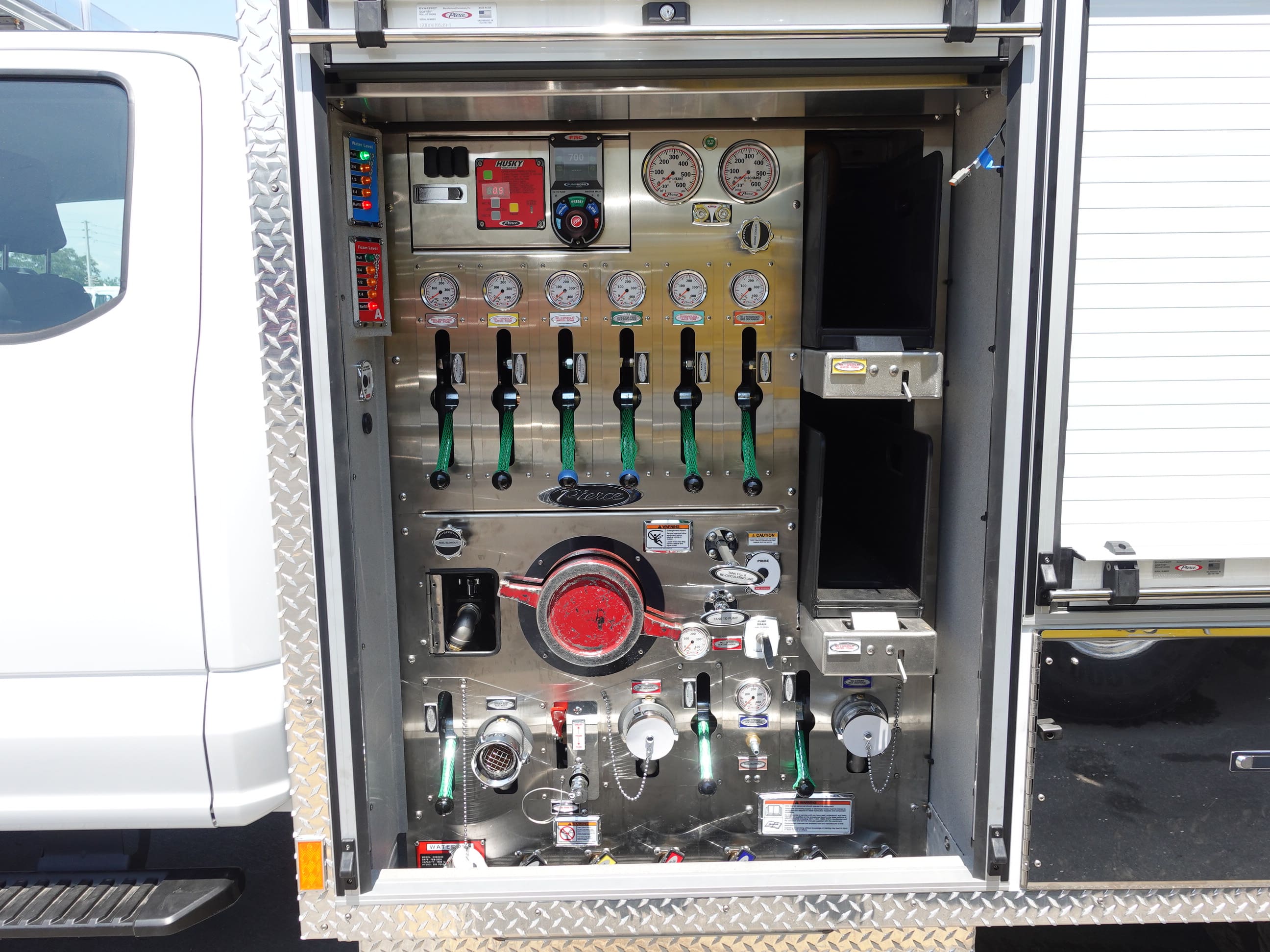

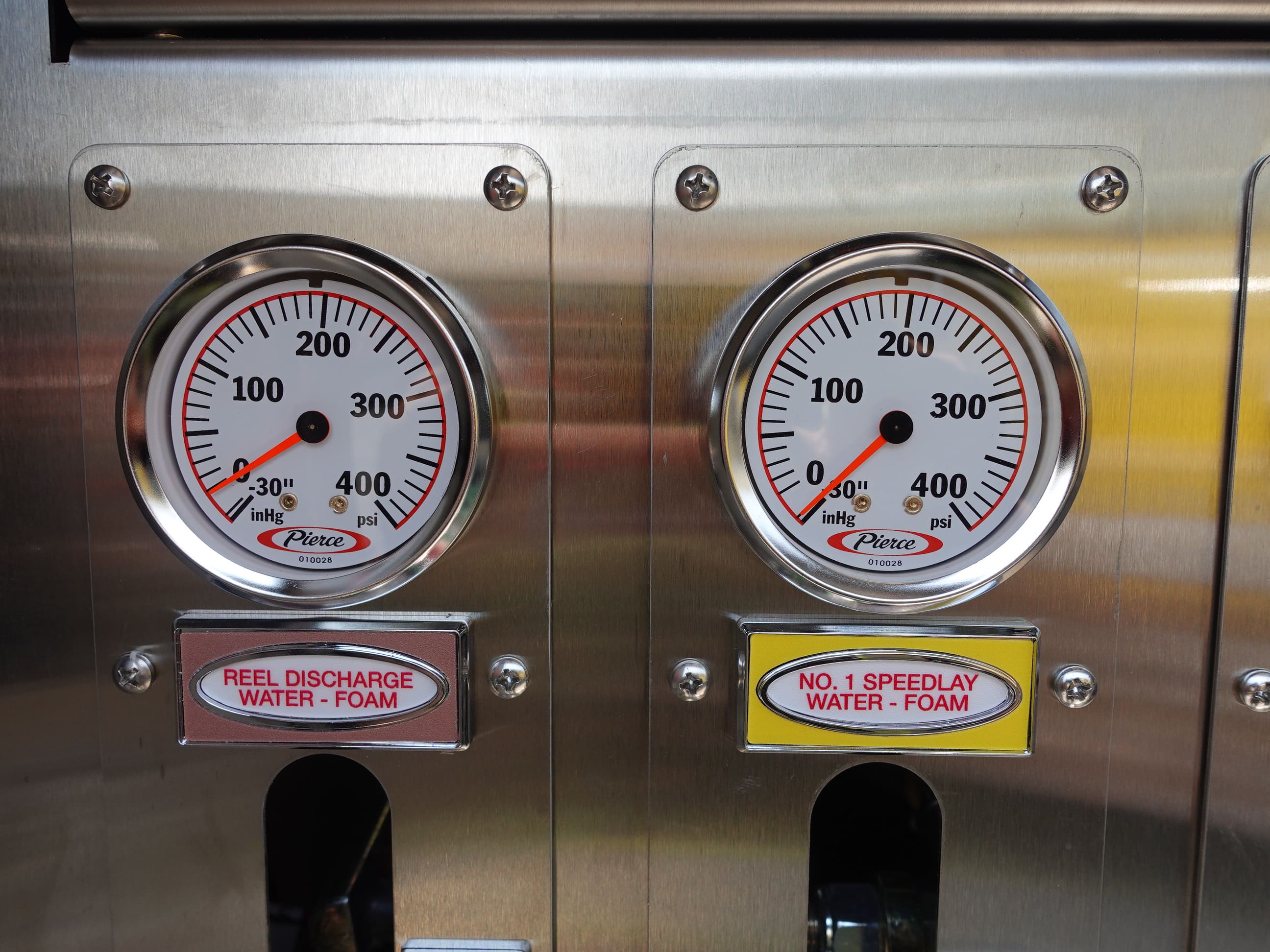

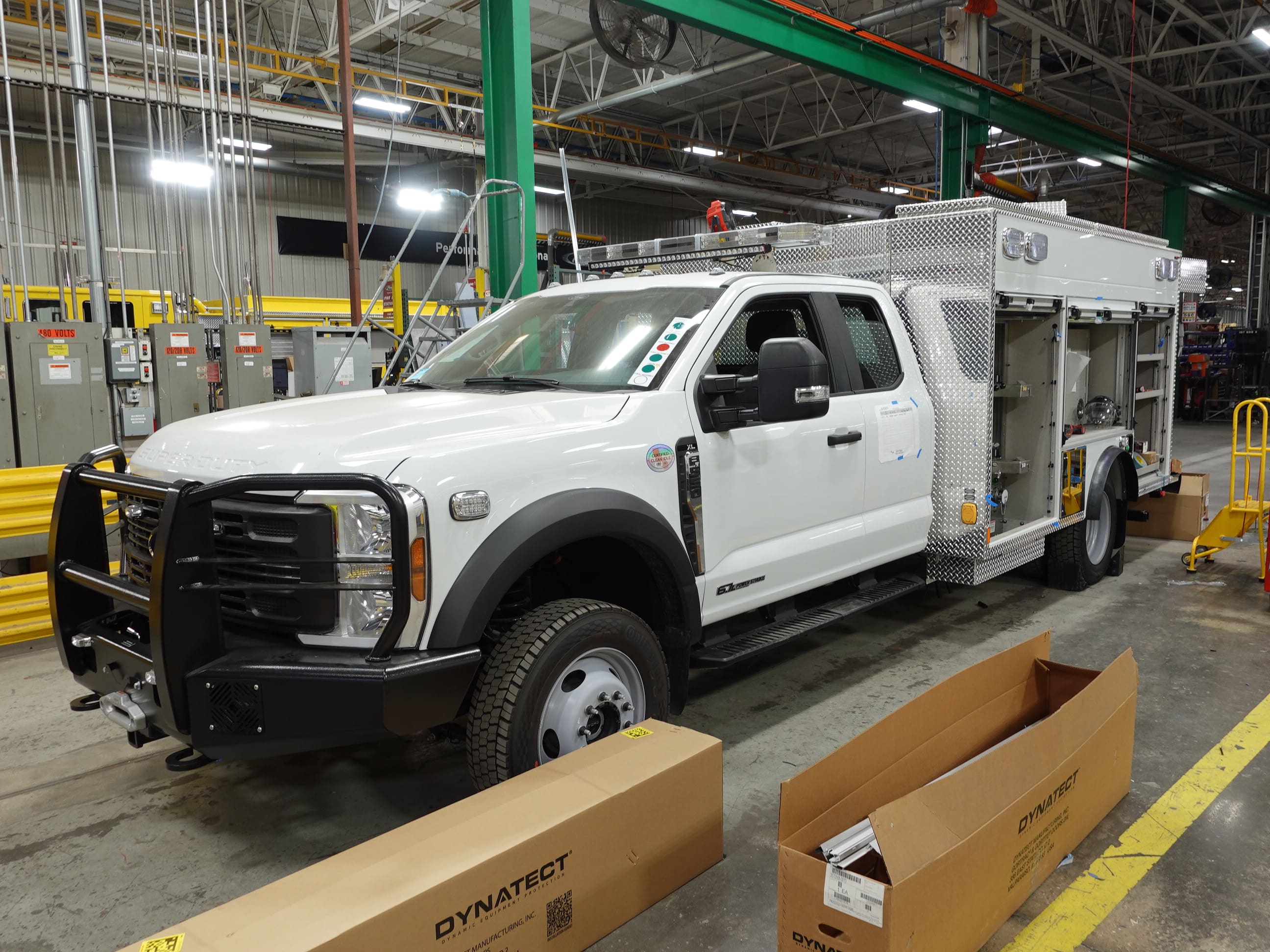

In this report the apparatus completed final

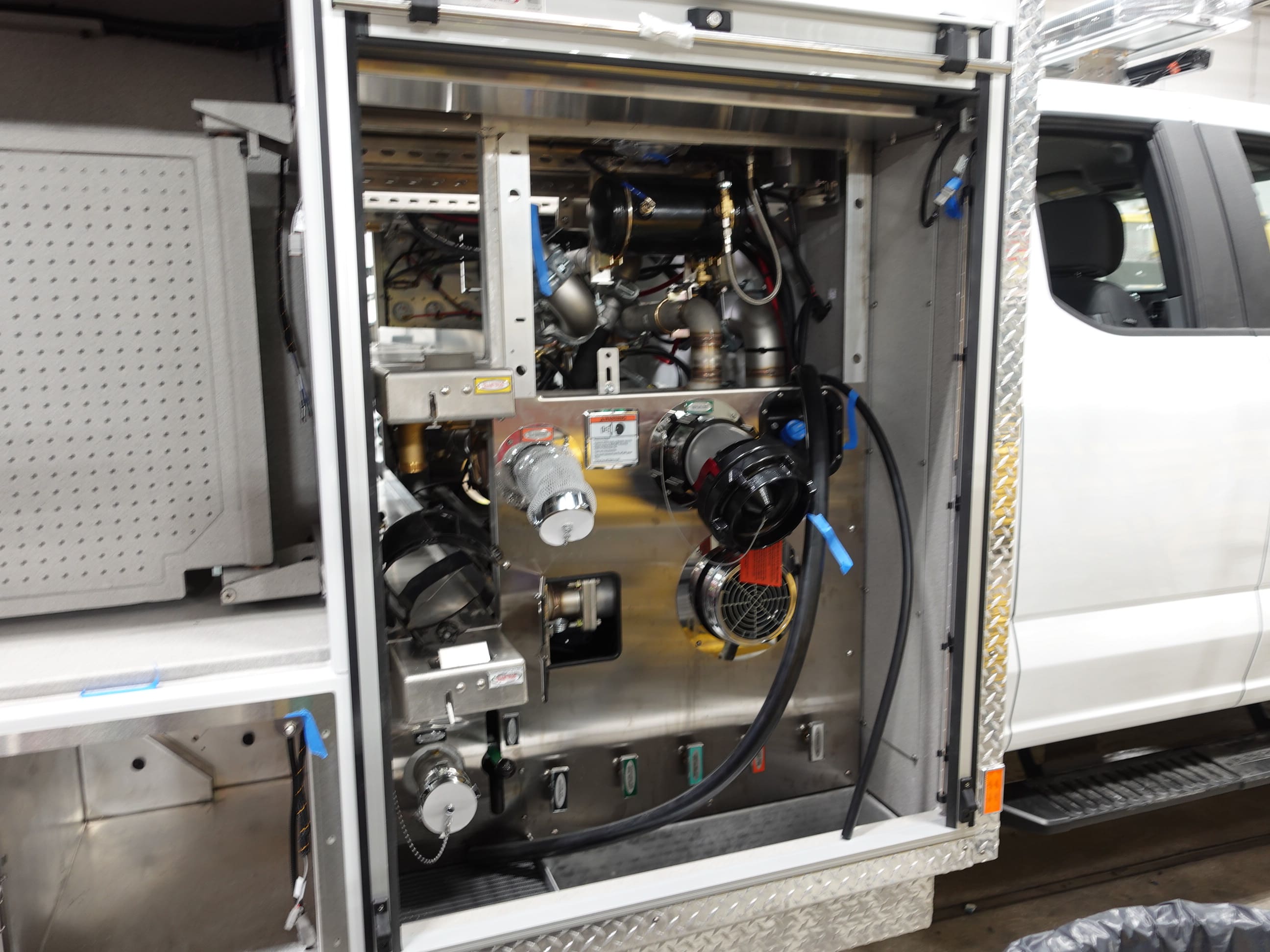

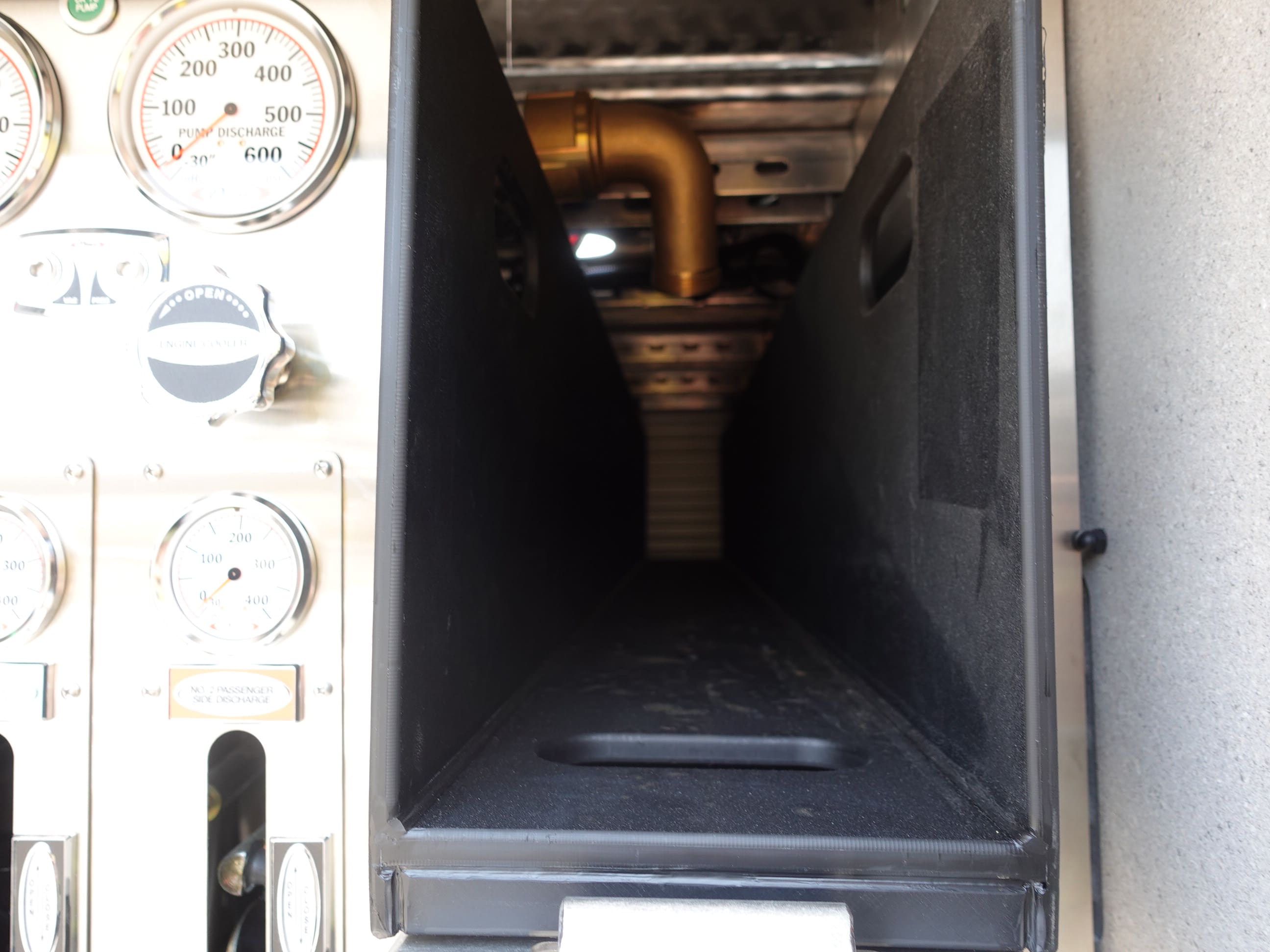

assembly and began testing. Once testing completes
it will release to final product evaluation where any
remaining content will be applied. When finished it
will be made ready for the customer acceptance
inspection. This is the last scheduled report.
05-01-26

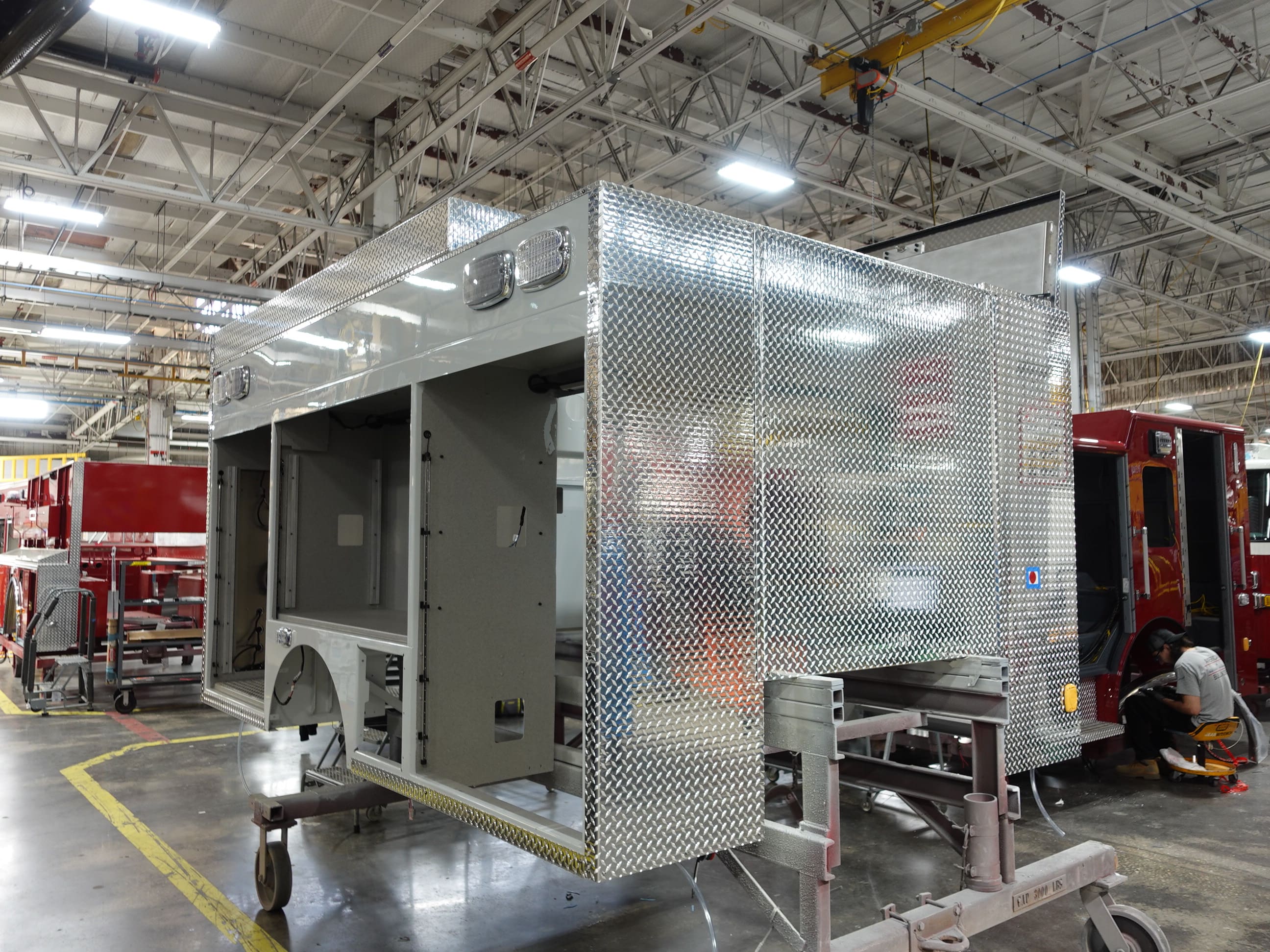

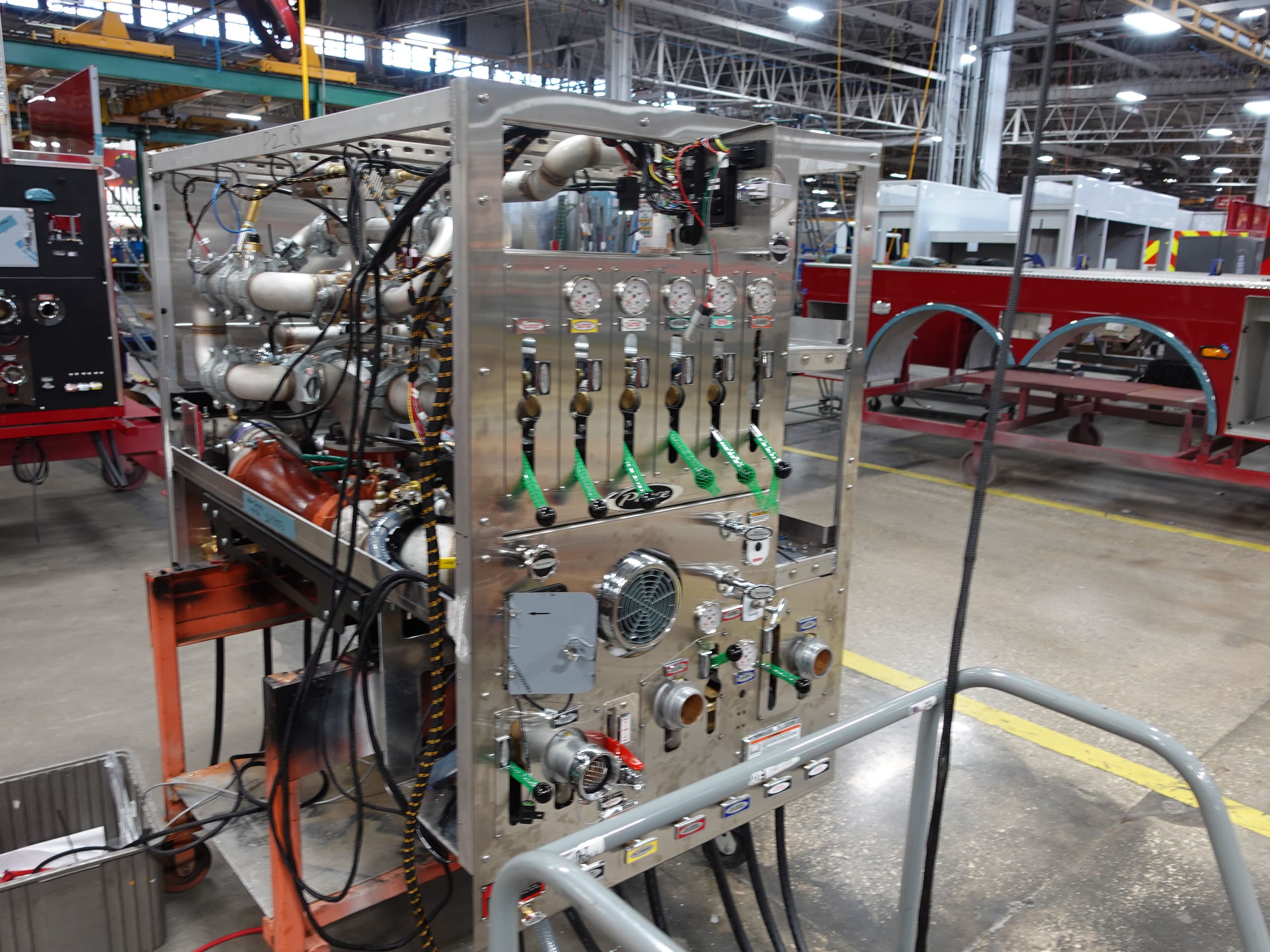

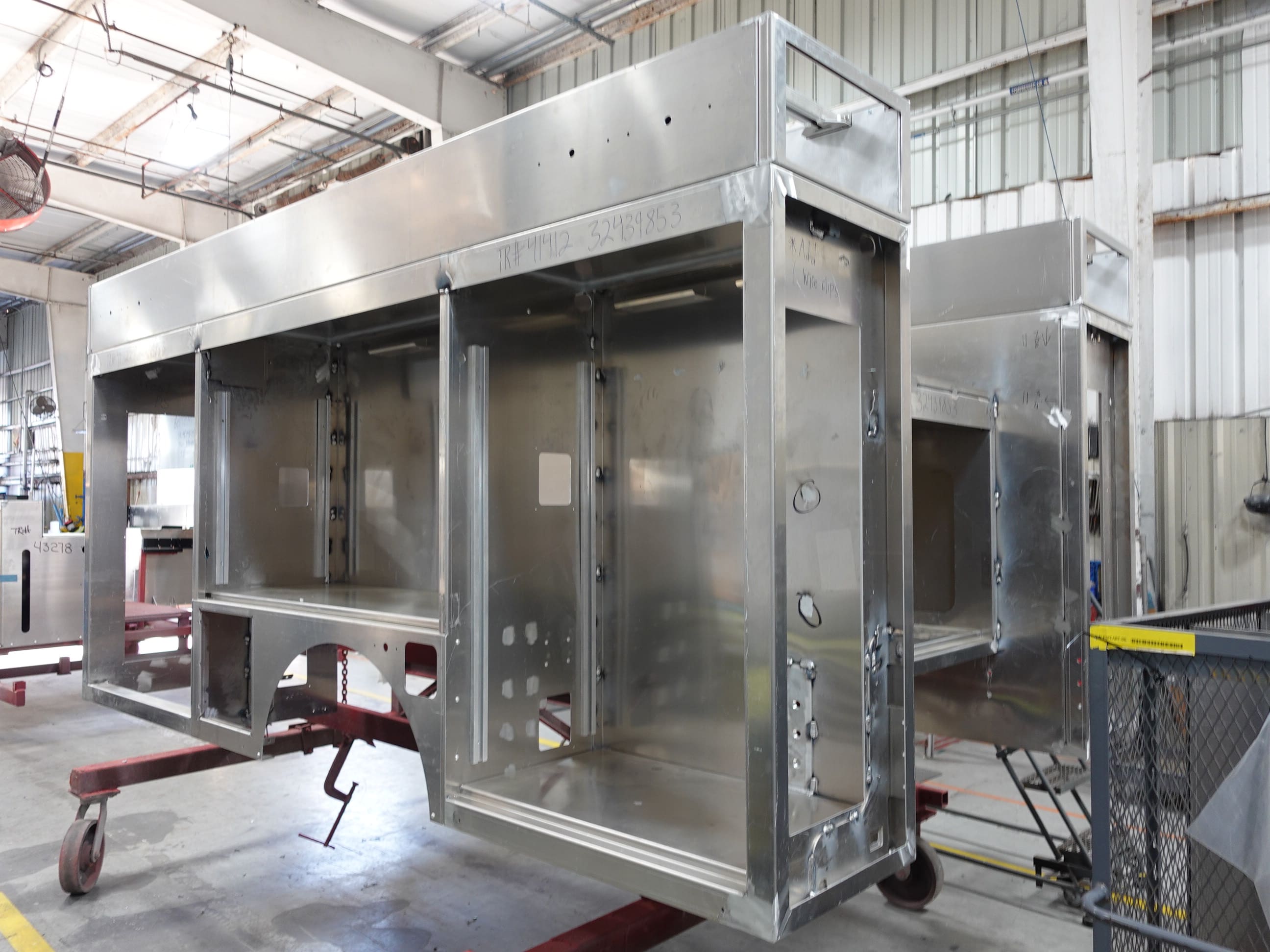

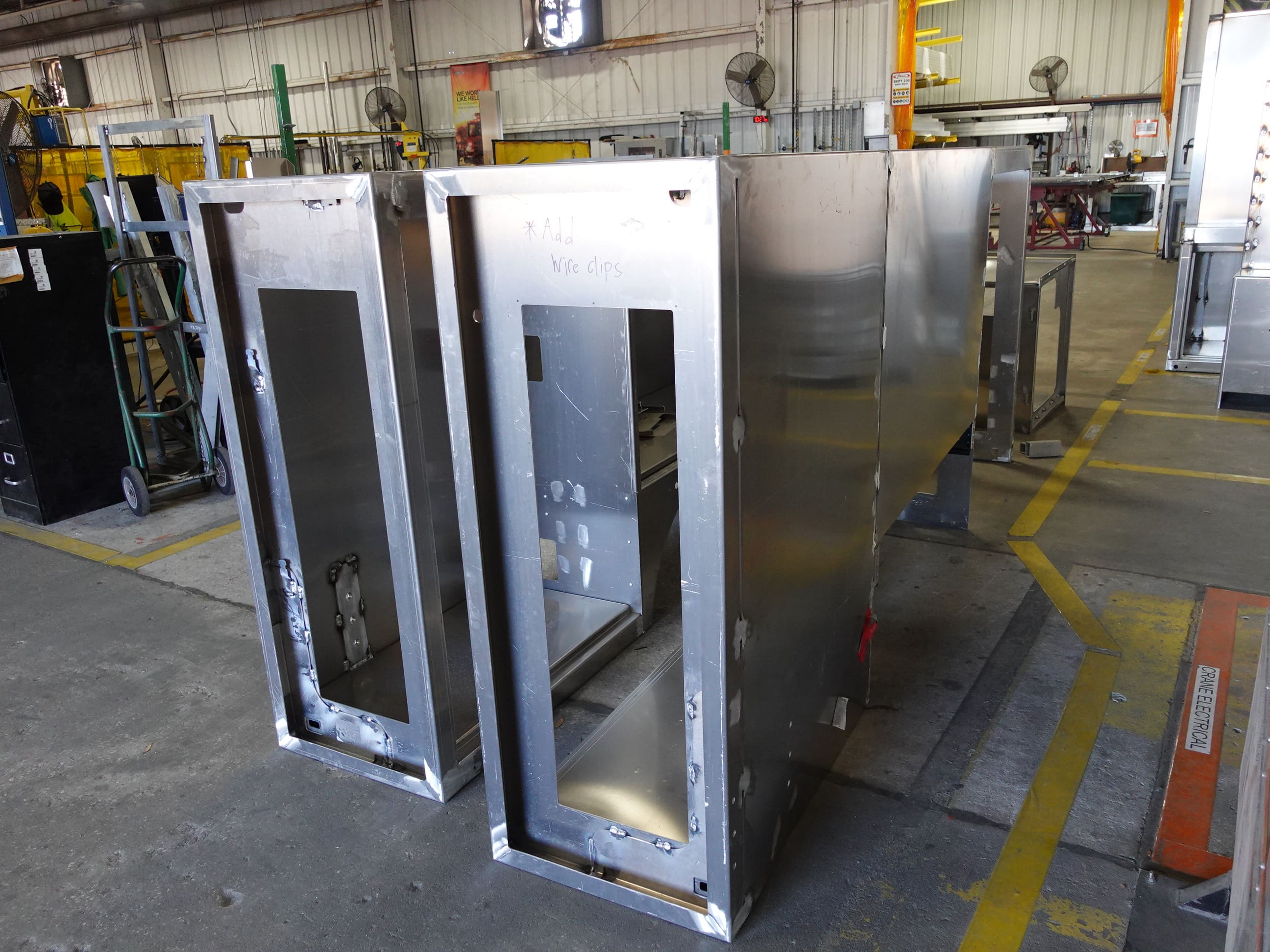

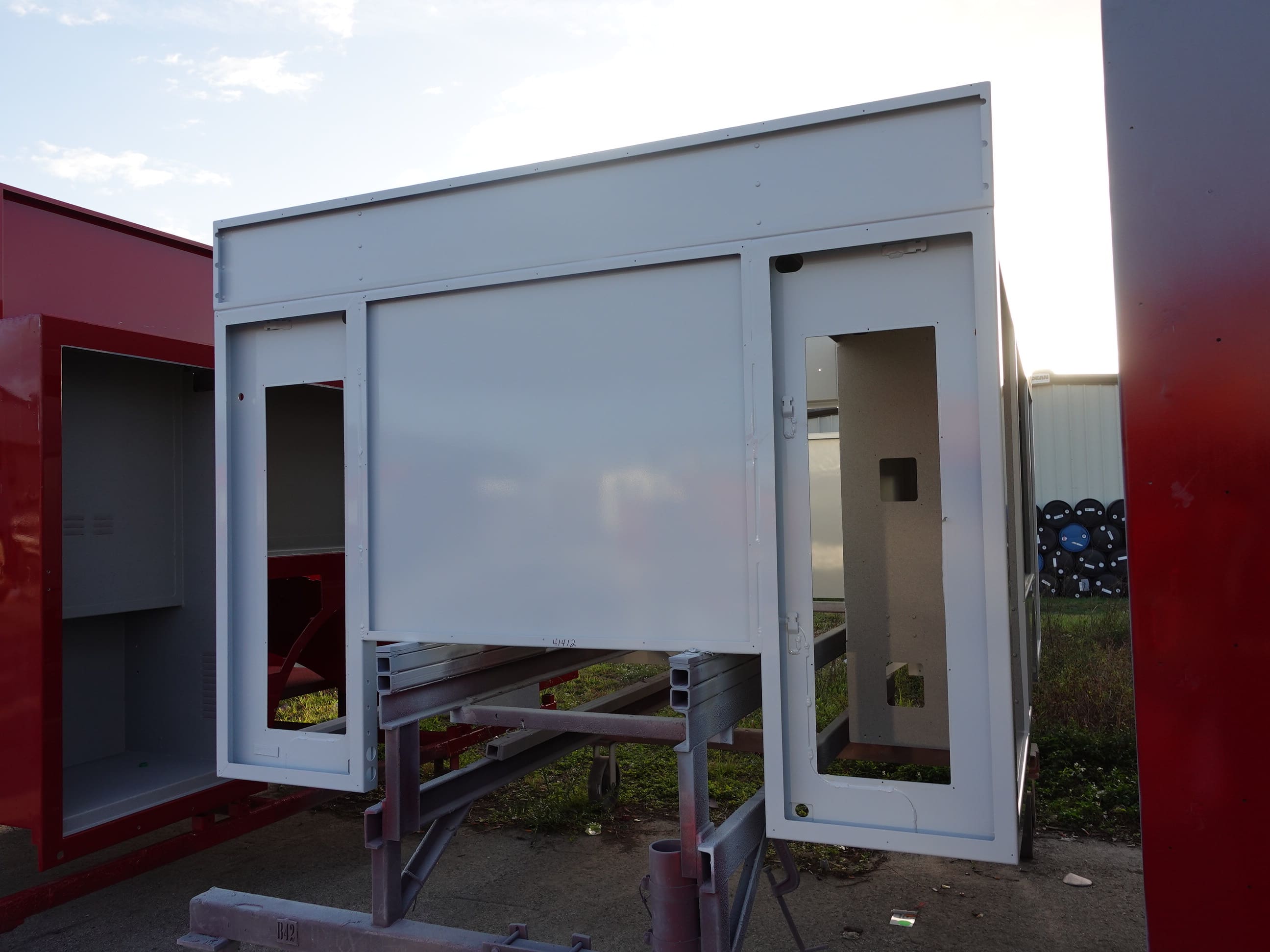

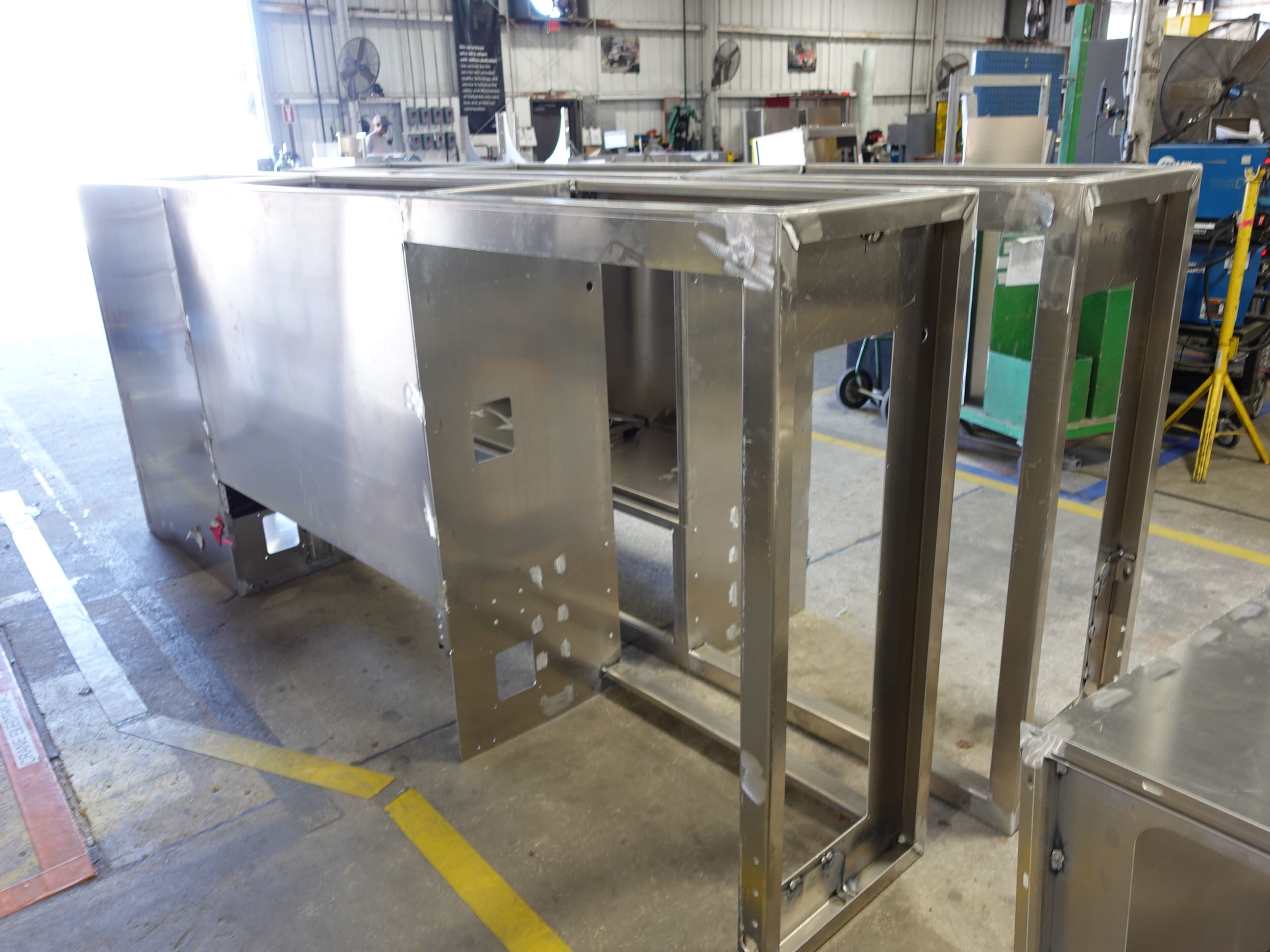

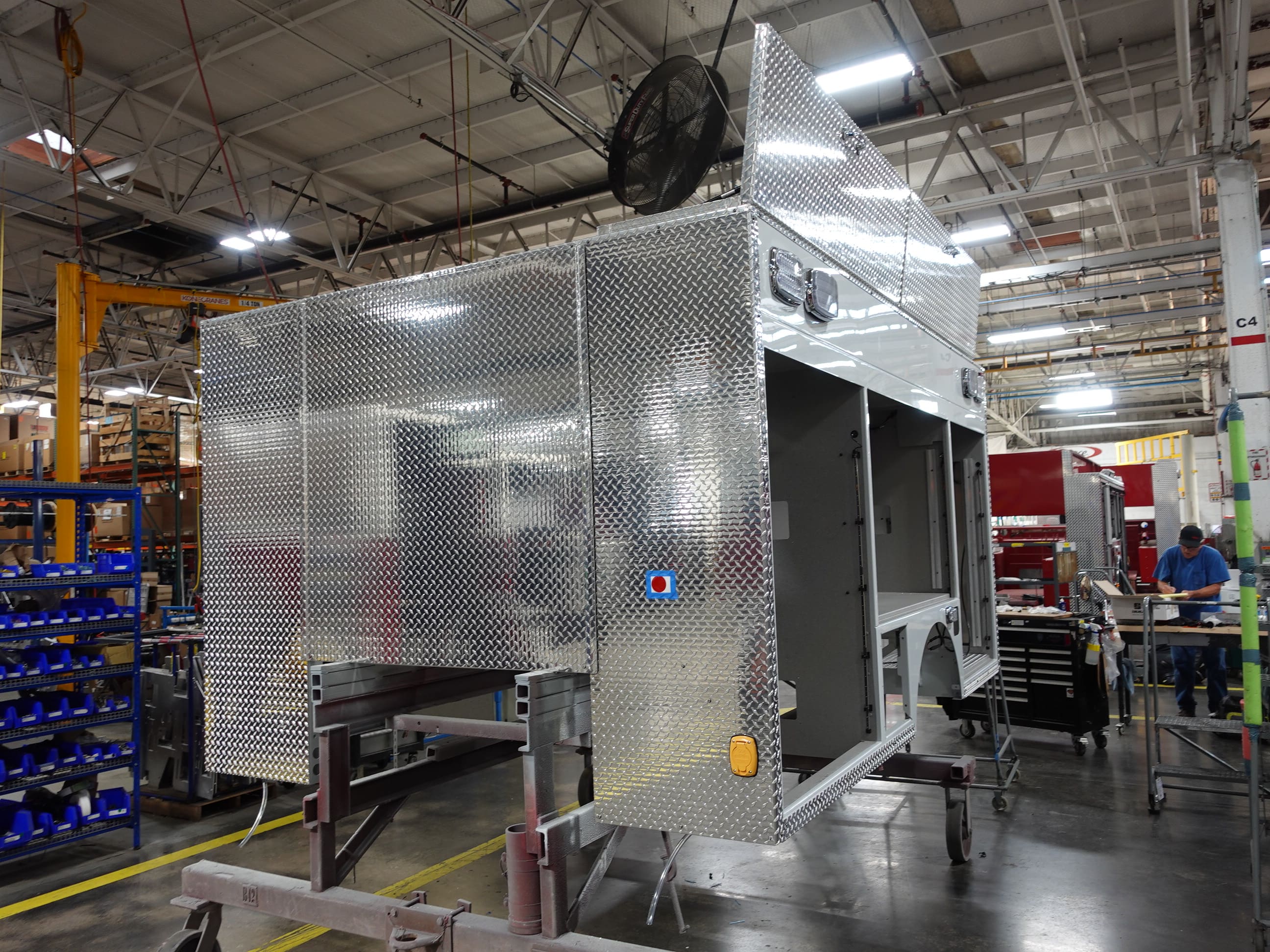

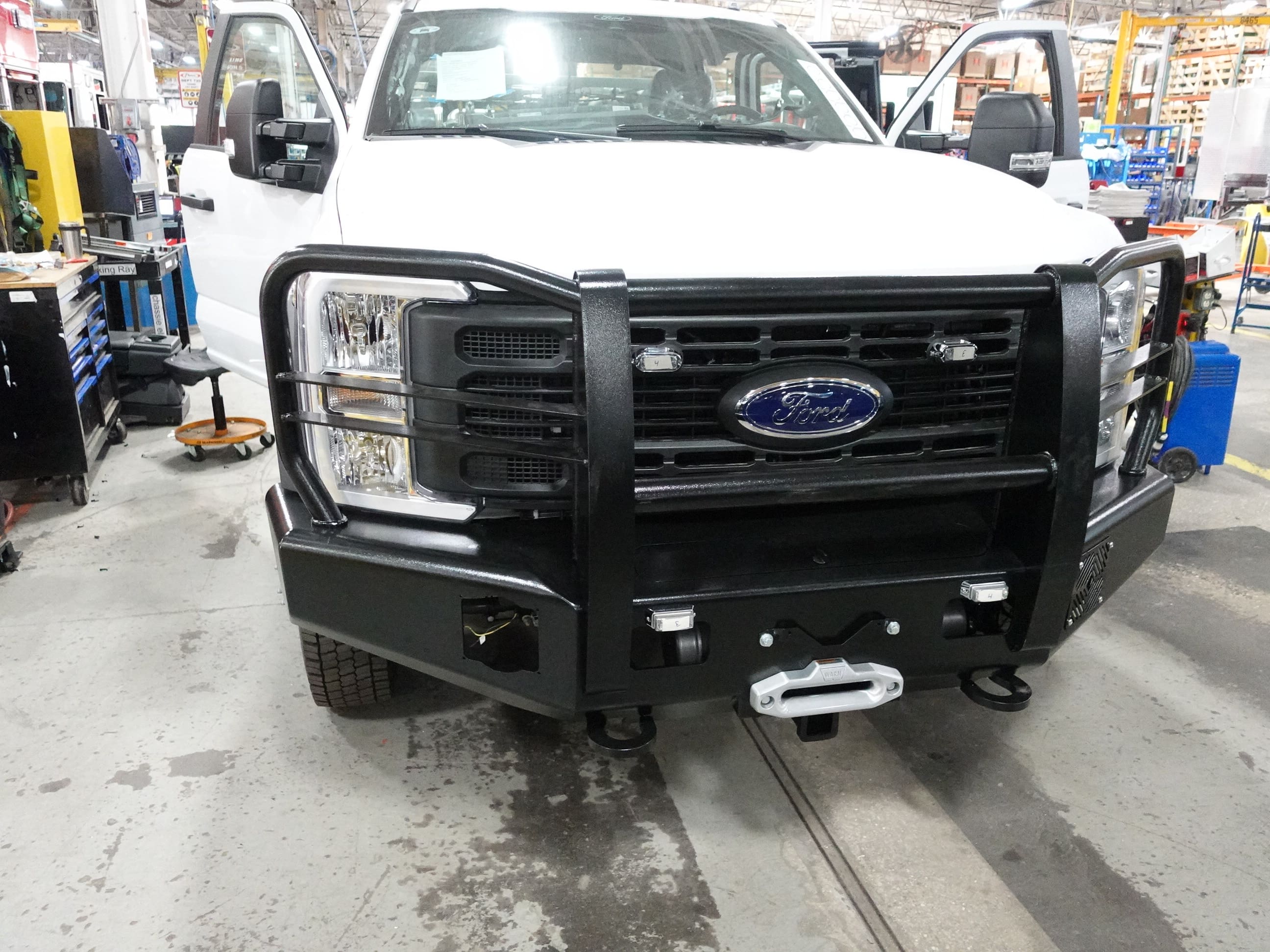

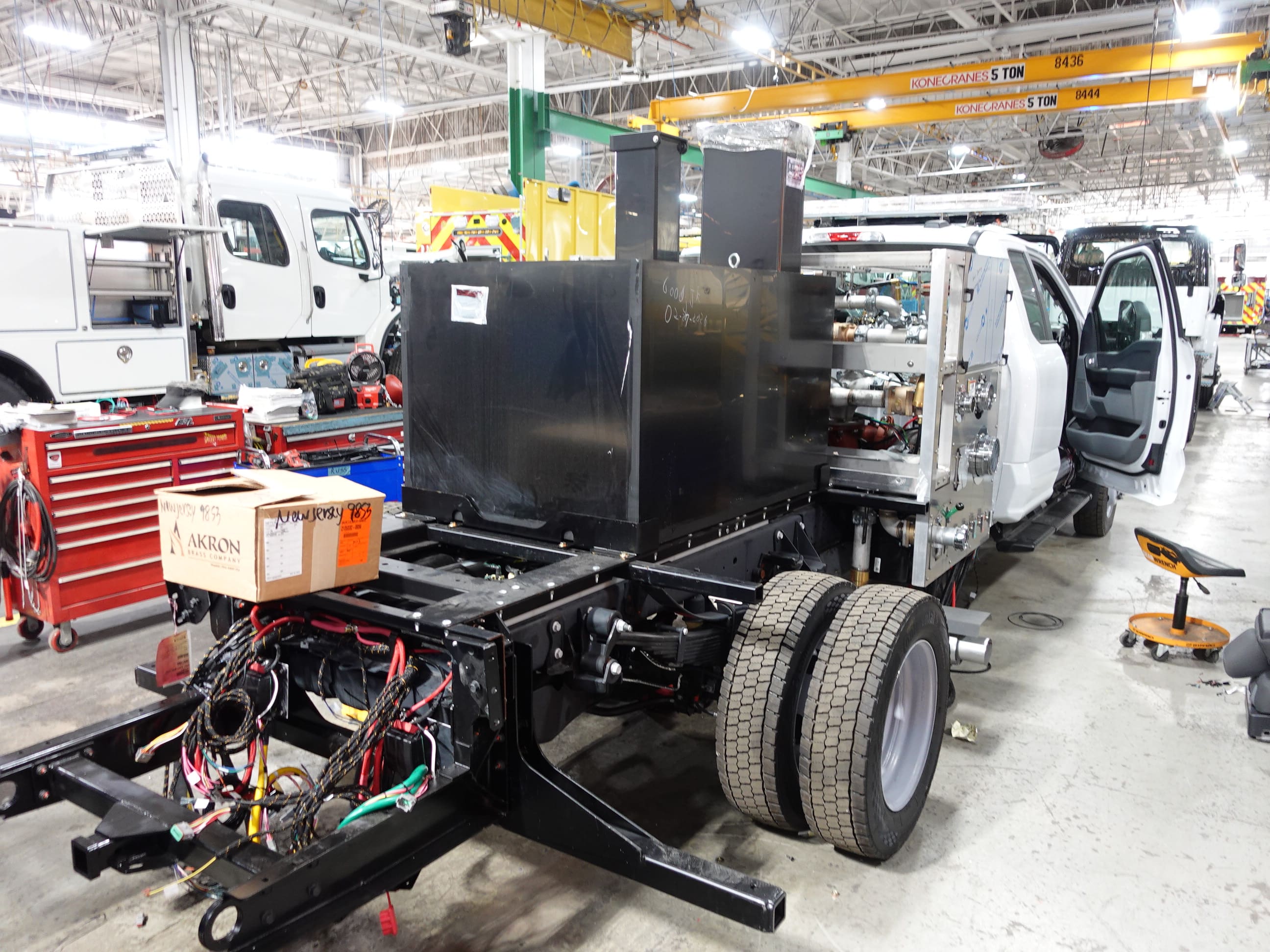

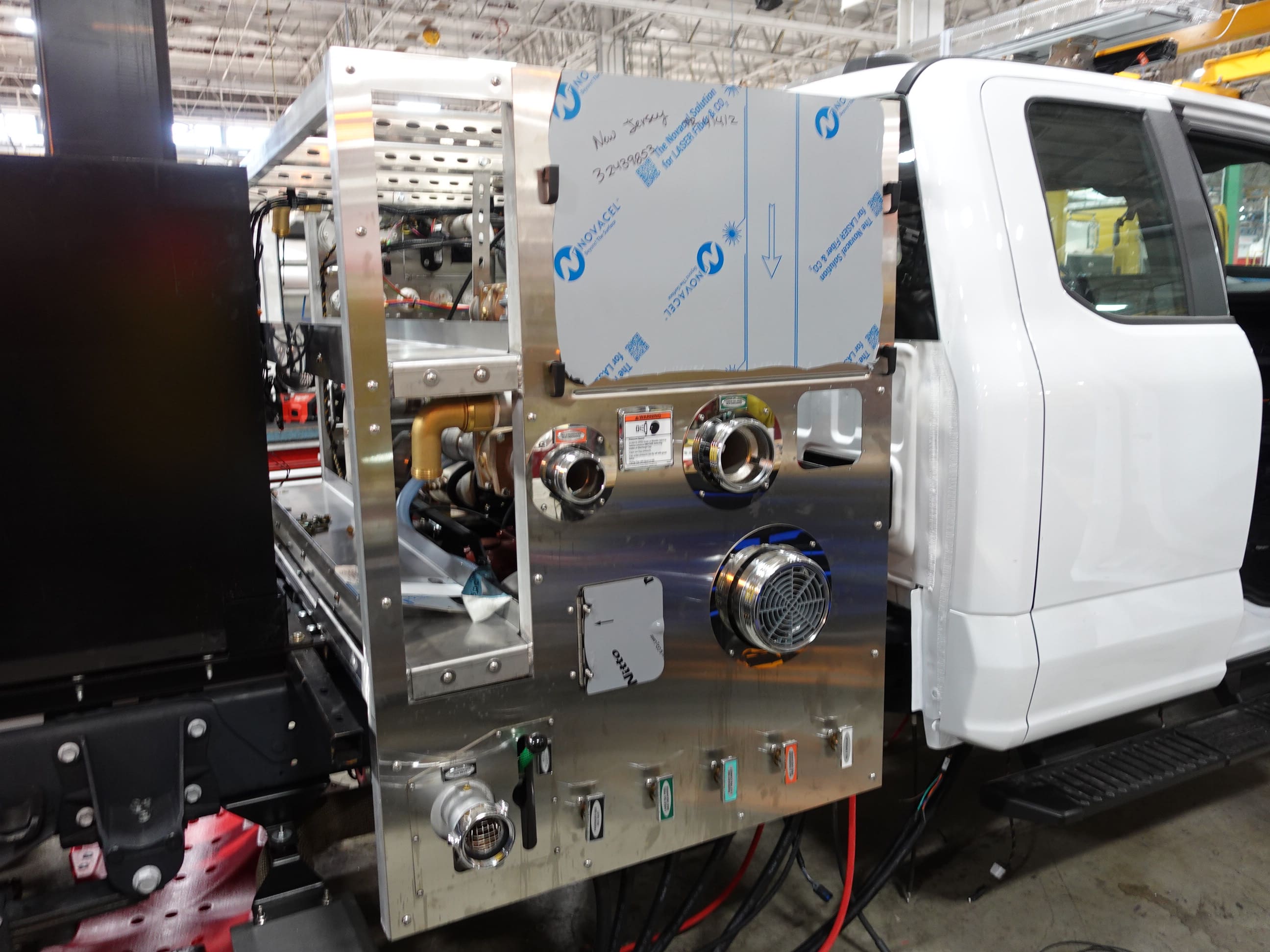

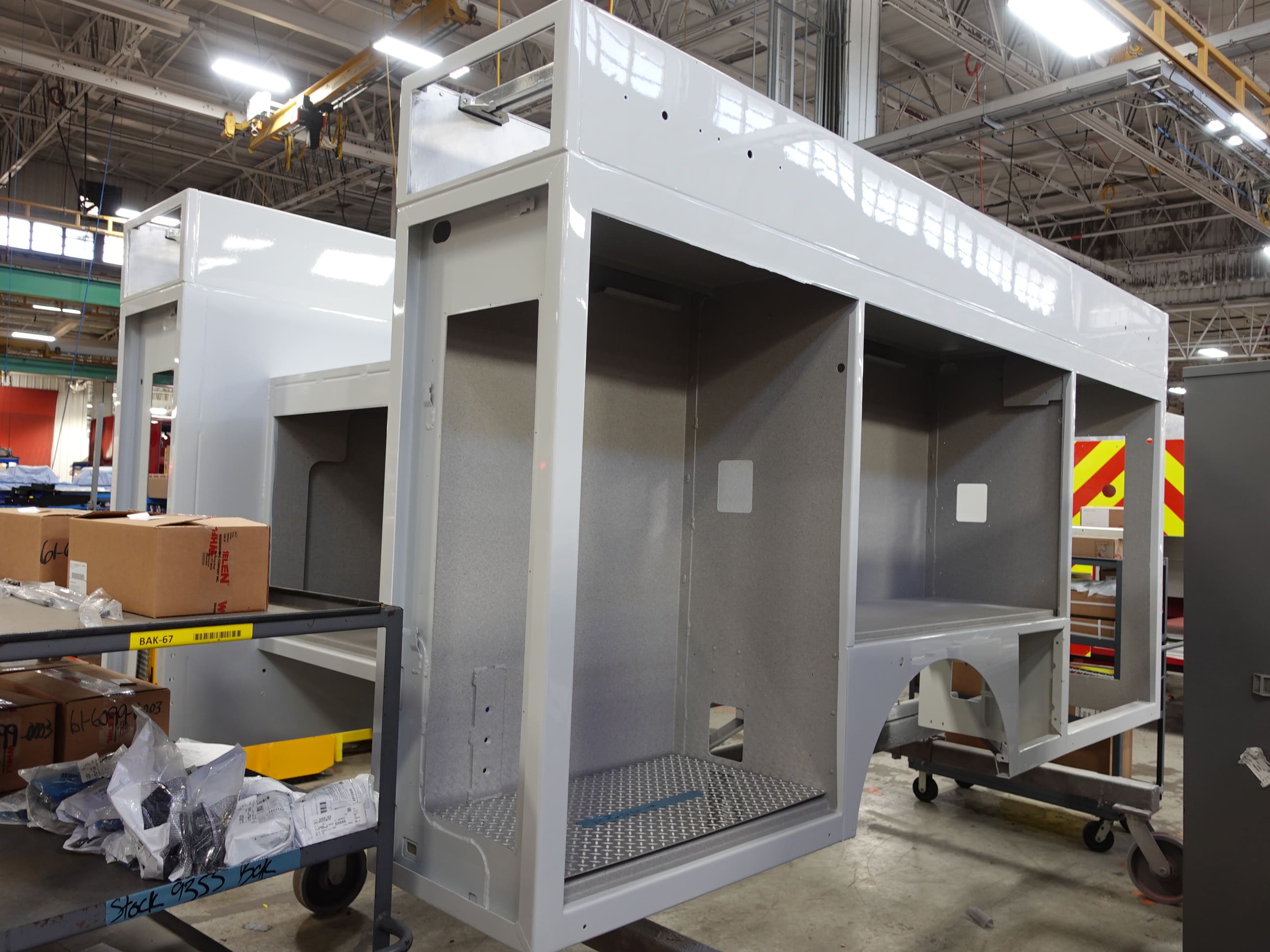

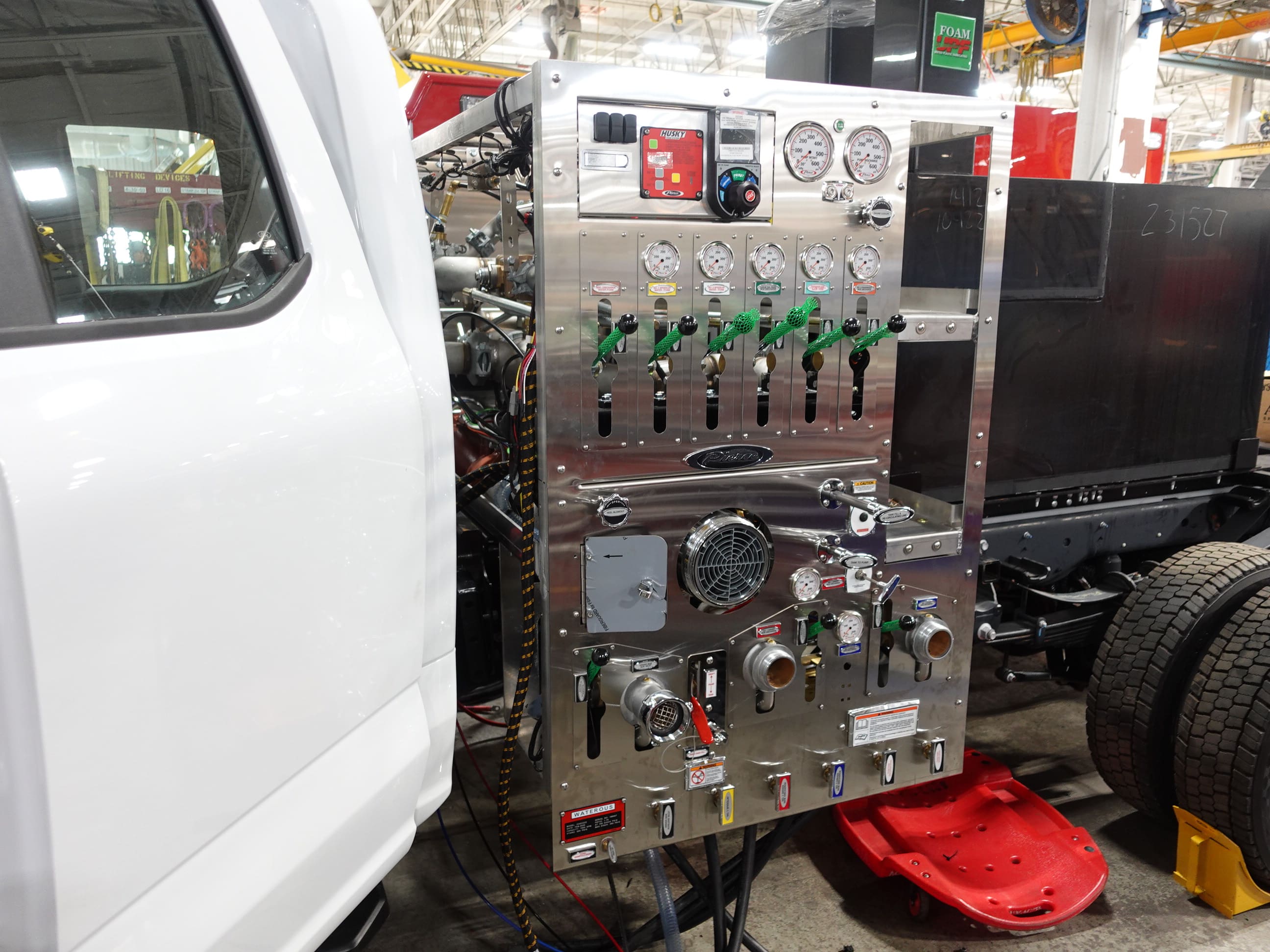

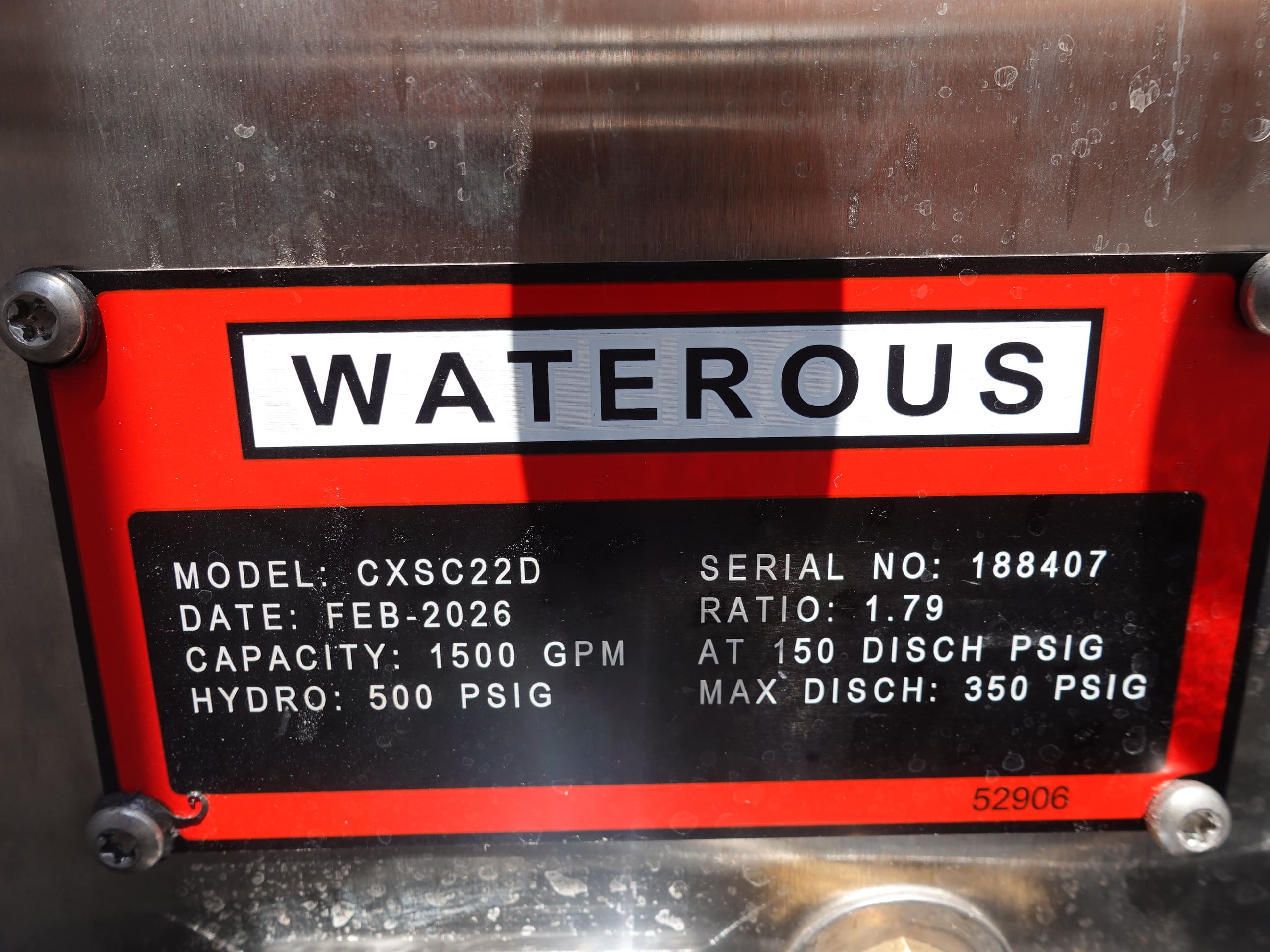

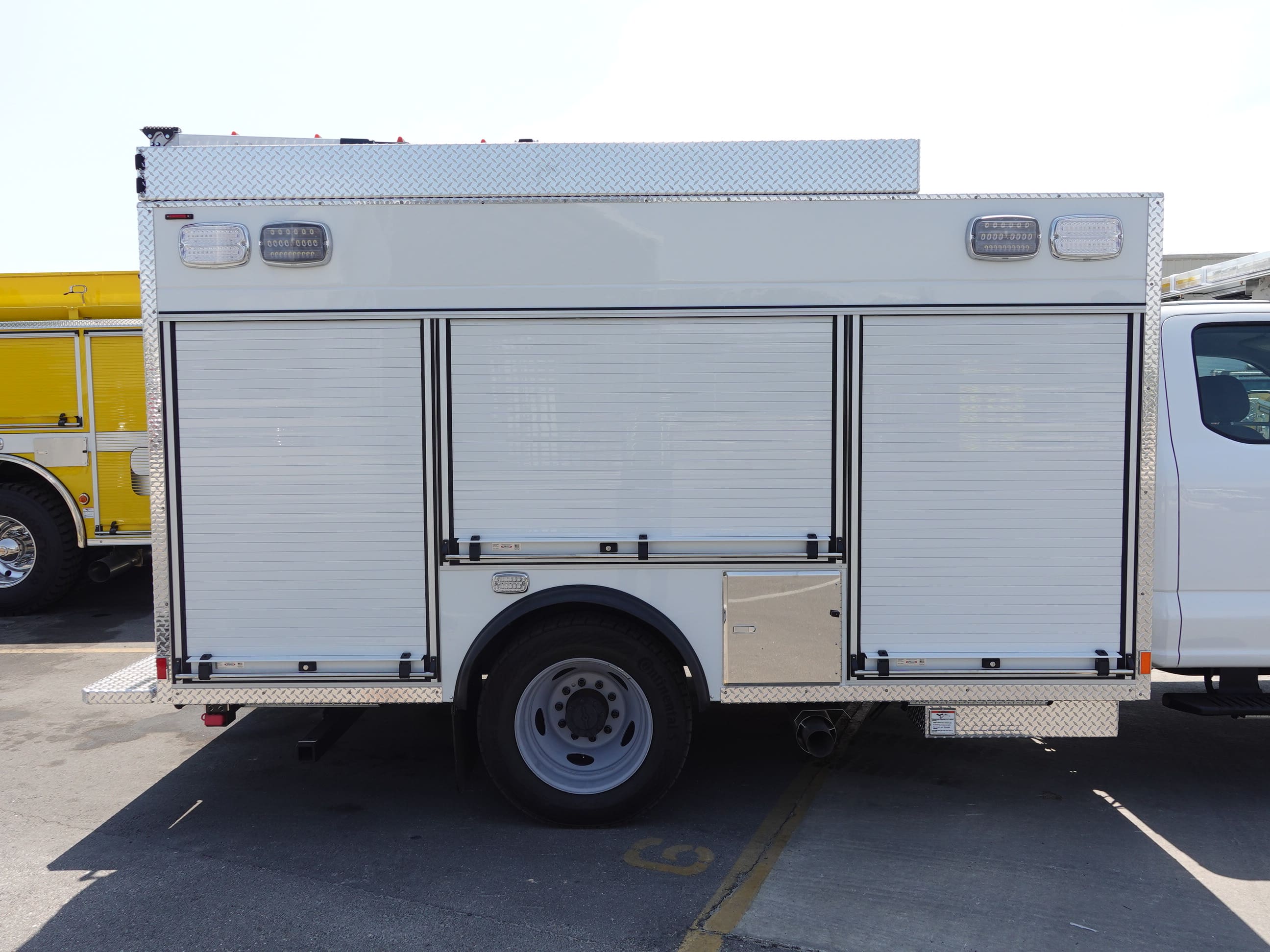

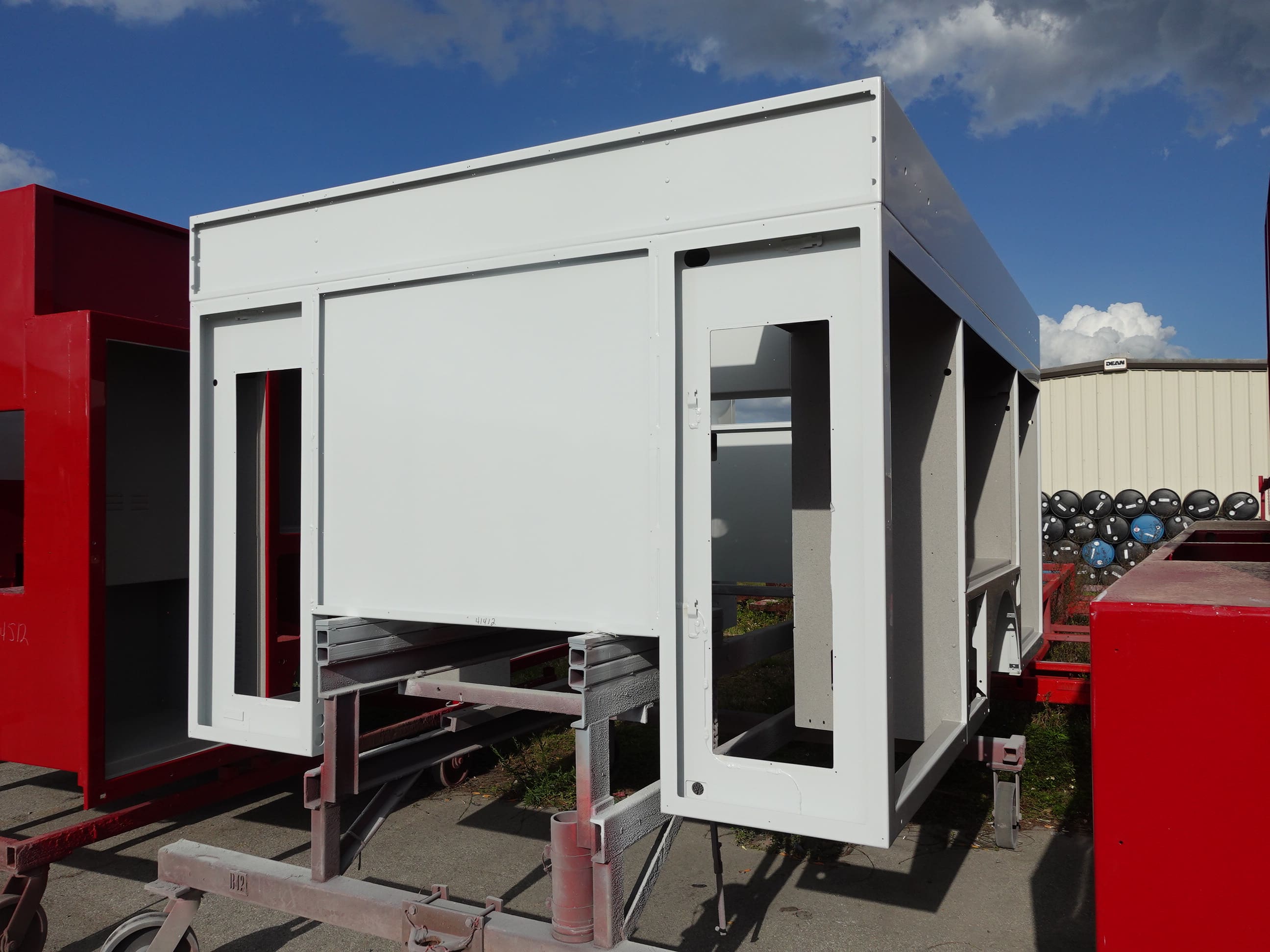

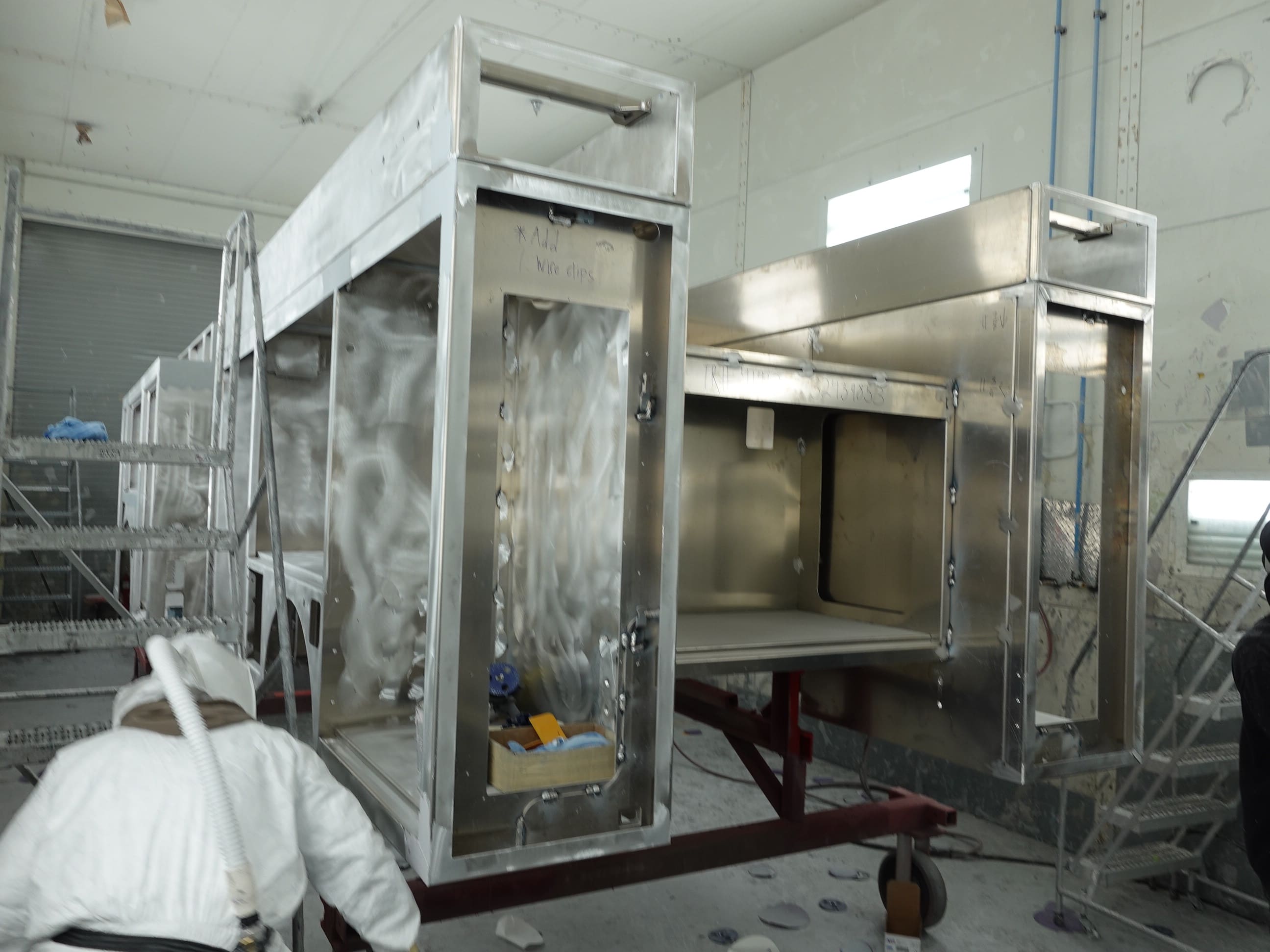

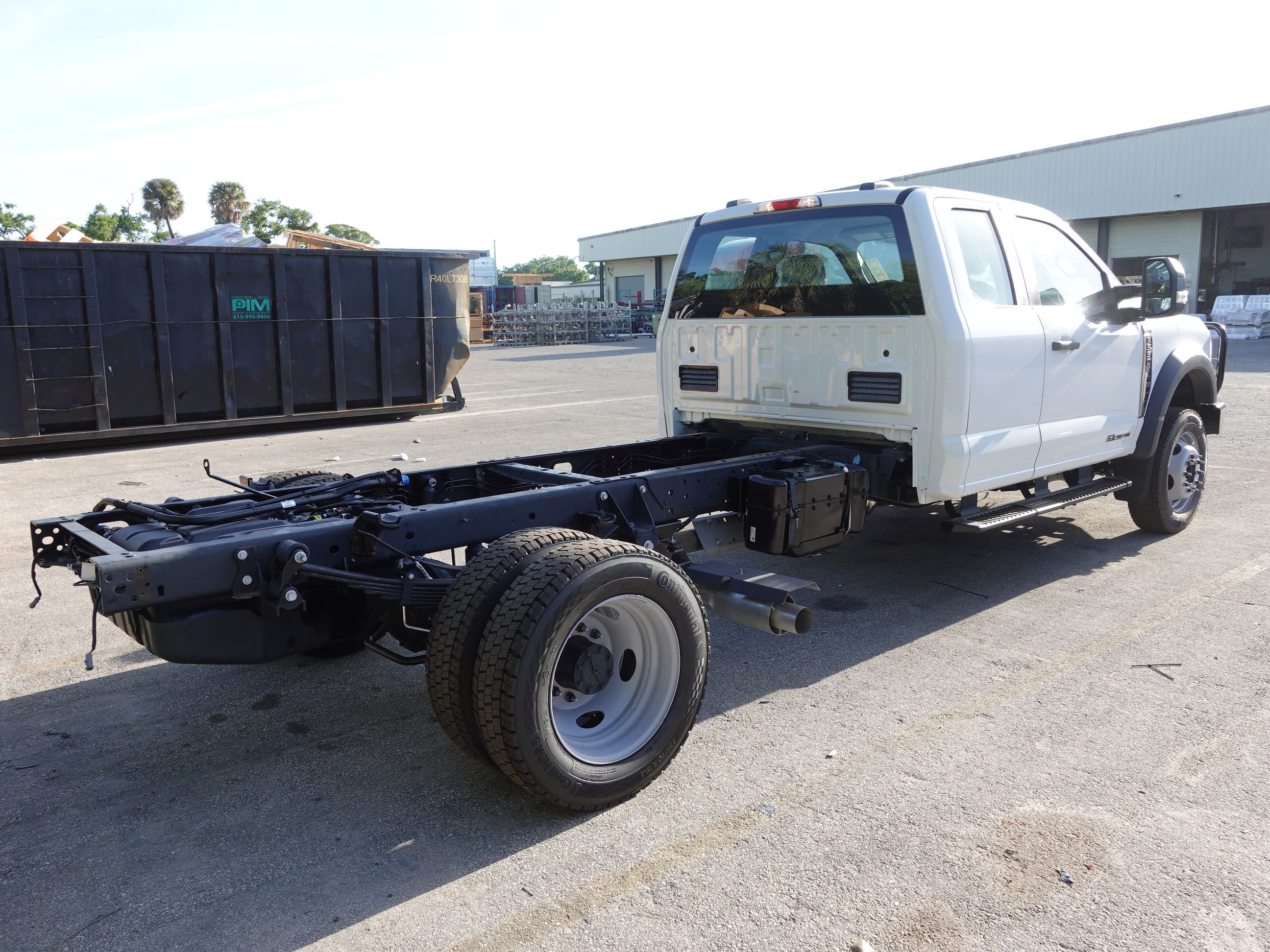

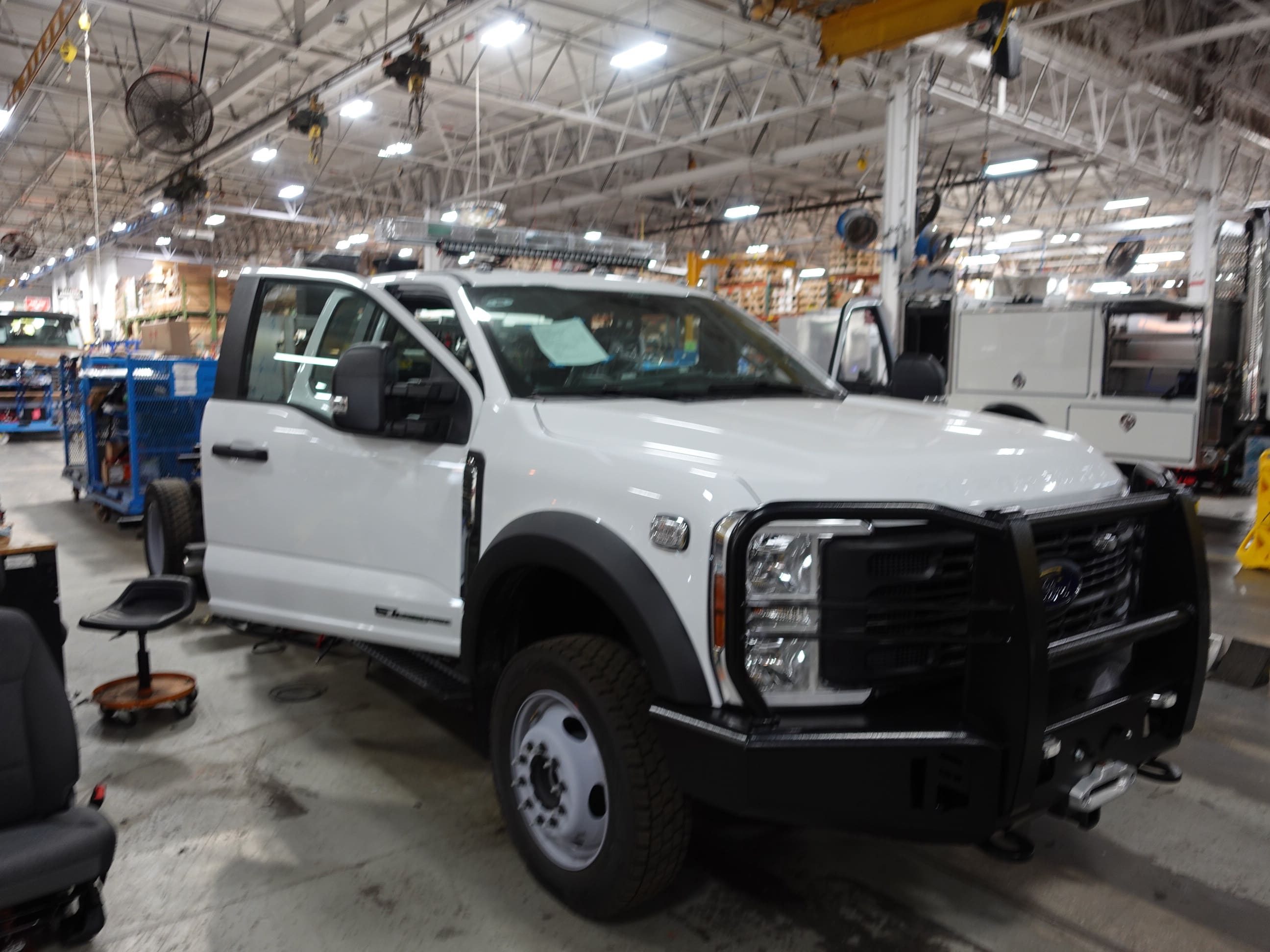

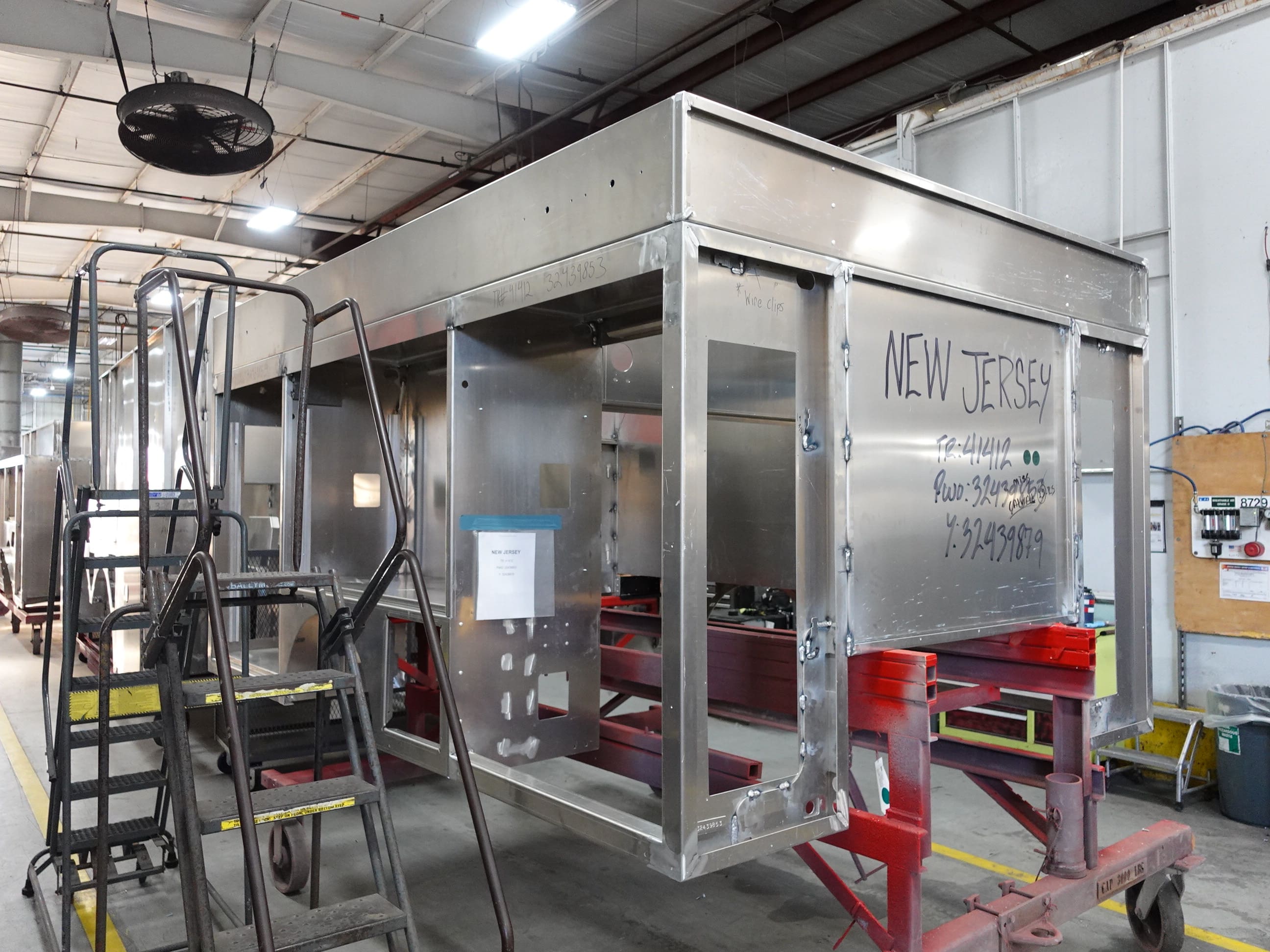

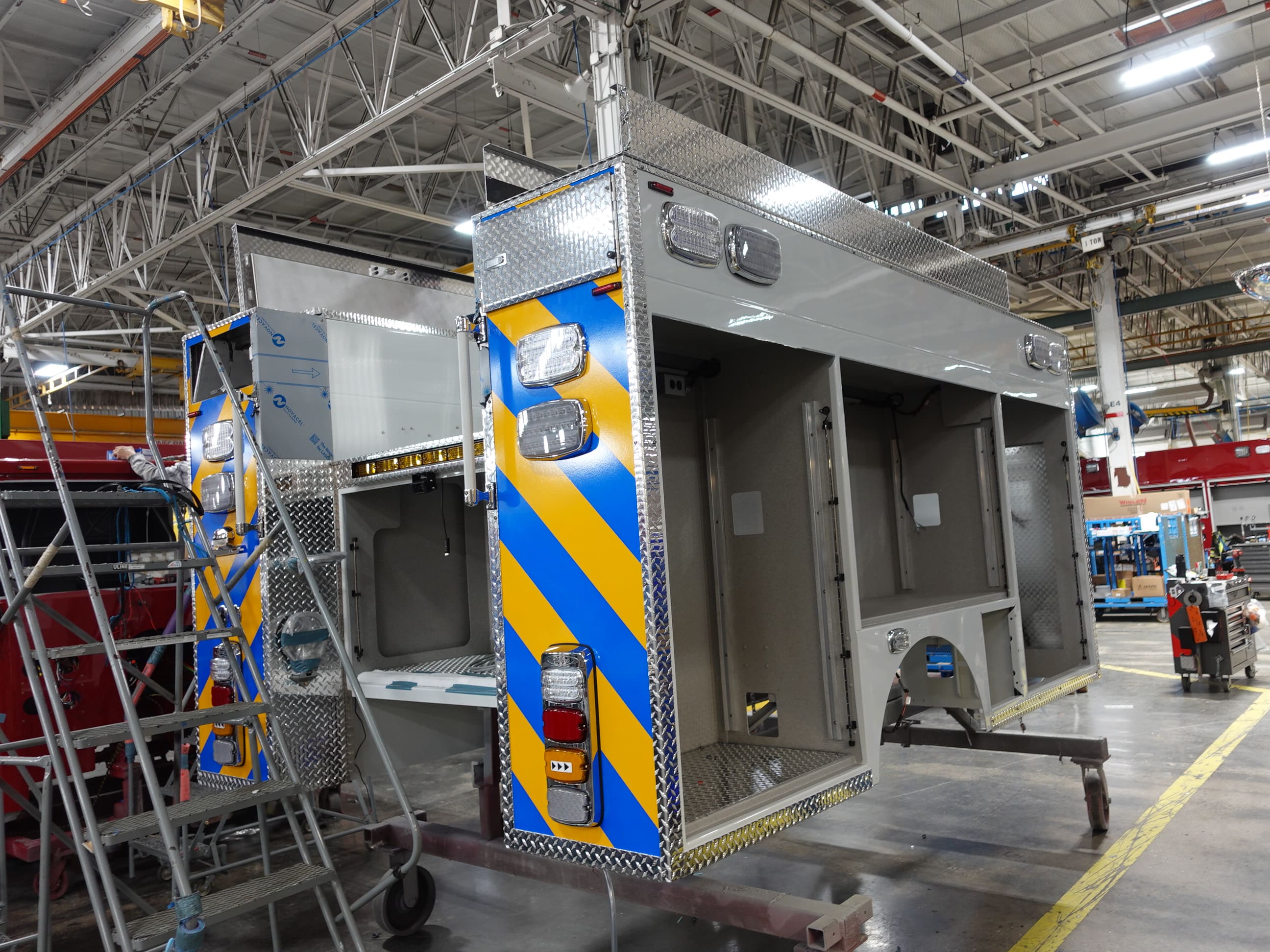

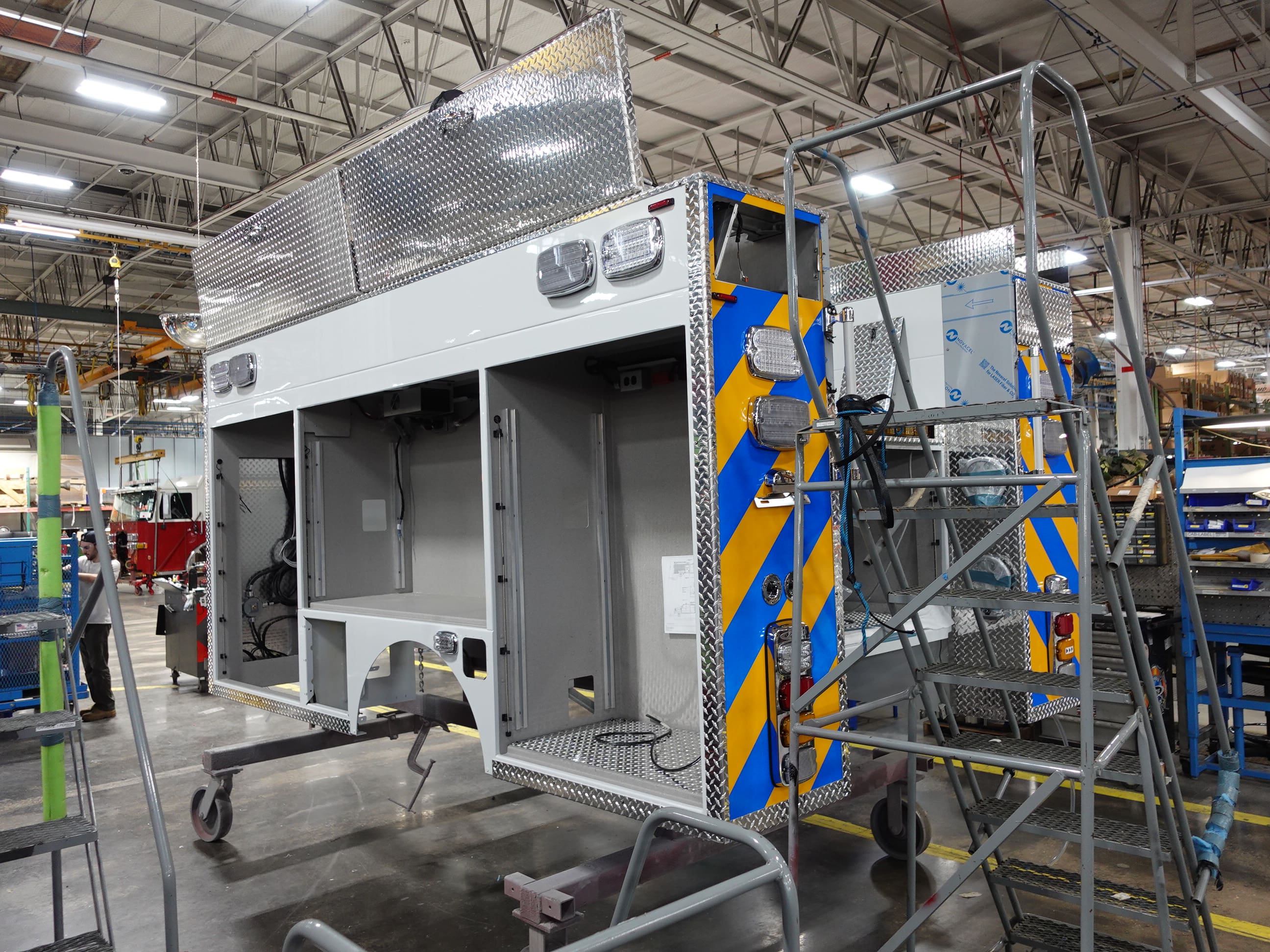

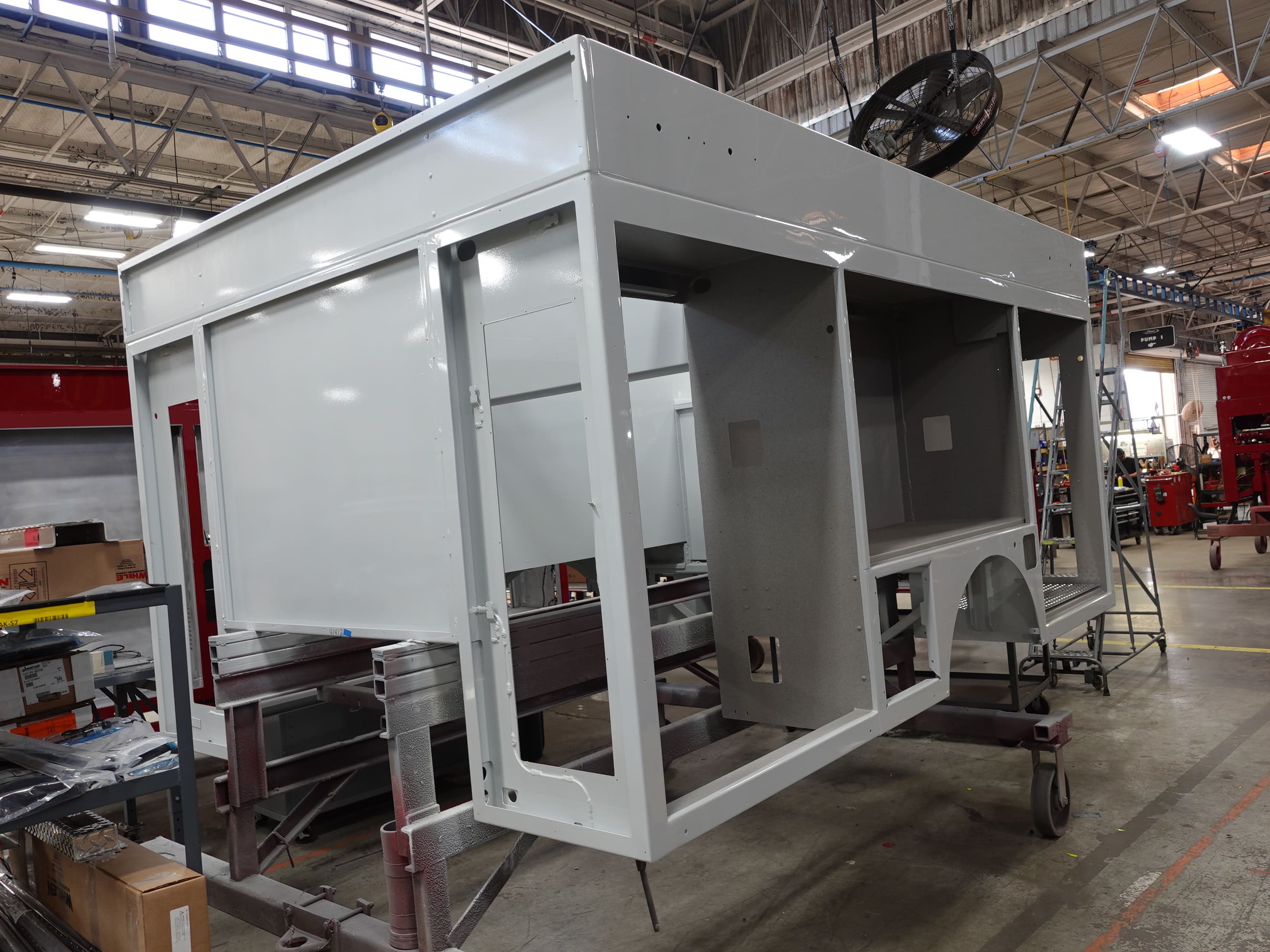

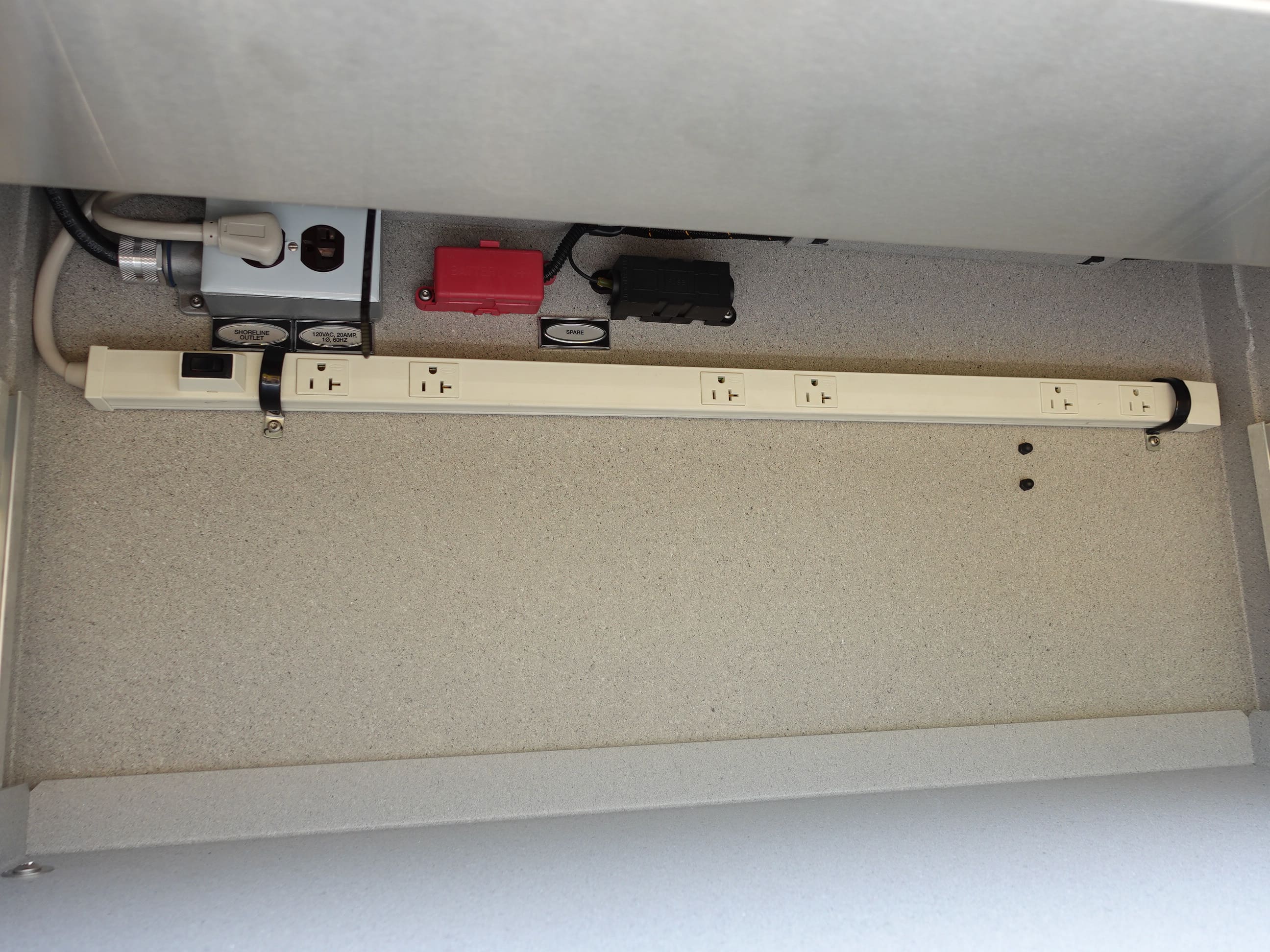

In this report, the body was merged with the chassis followed by the start of final assembly.

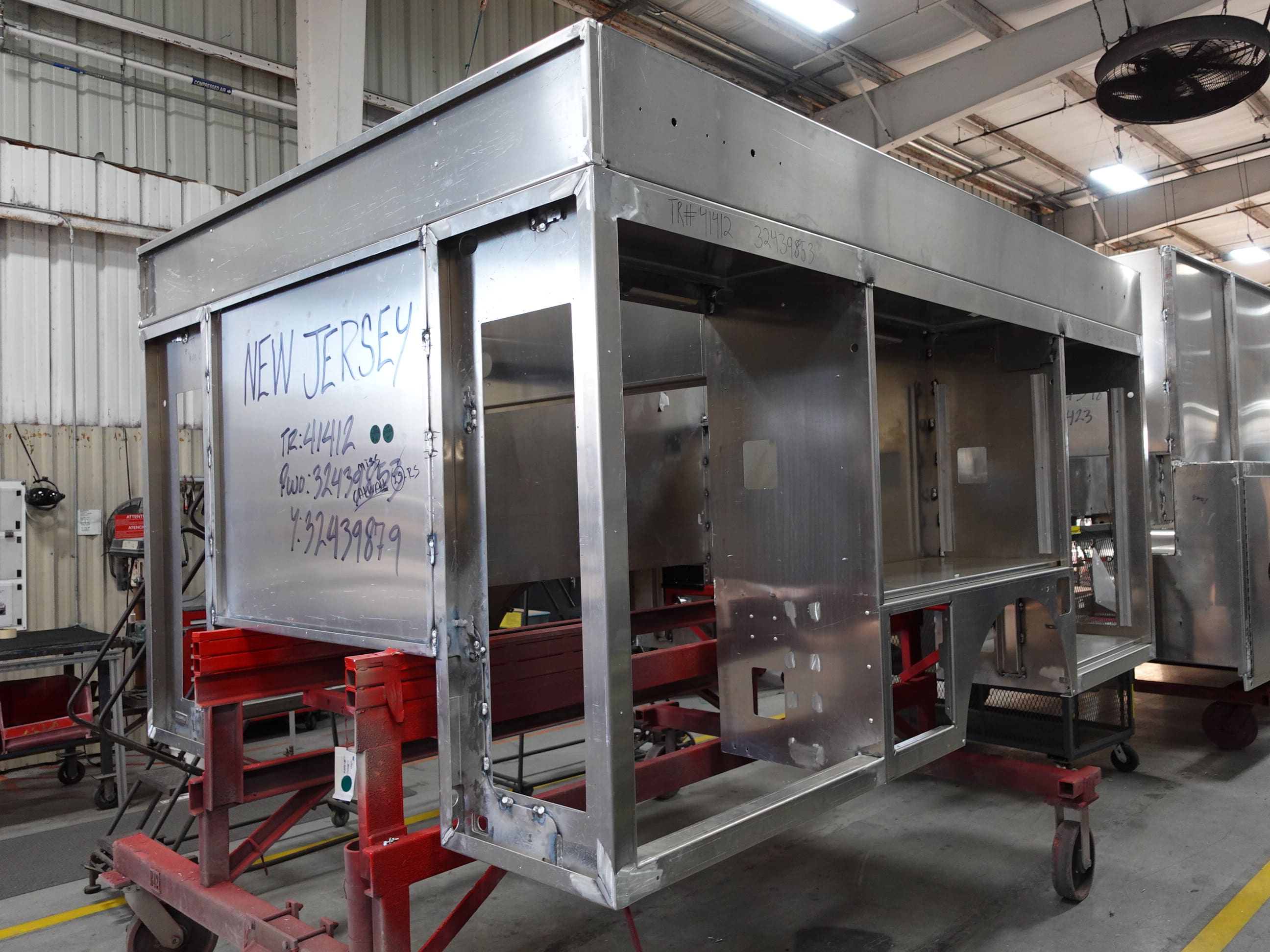

04-24-26

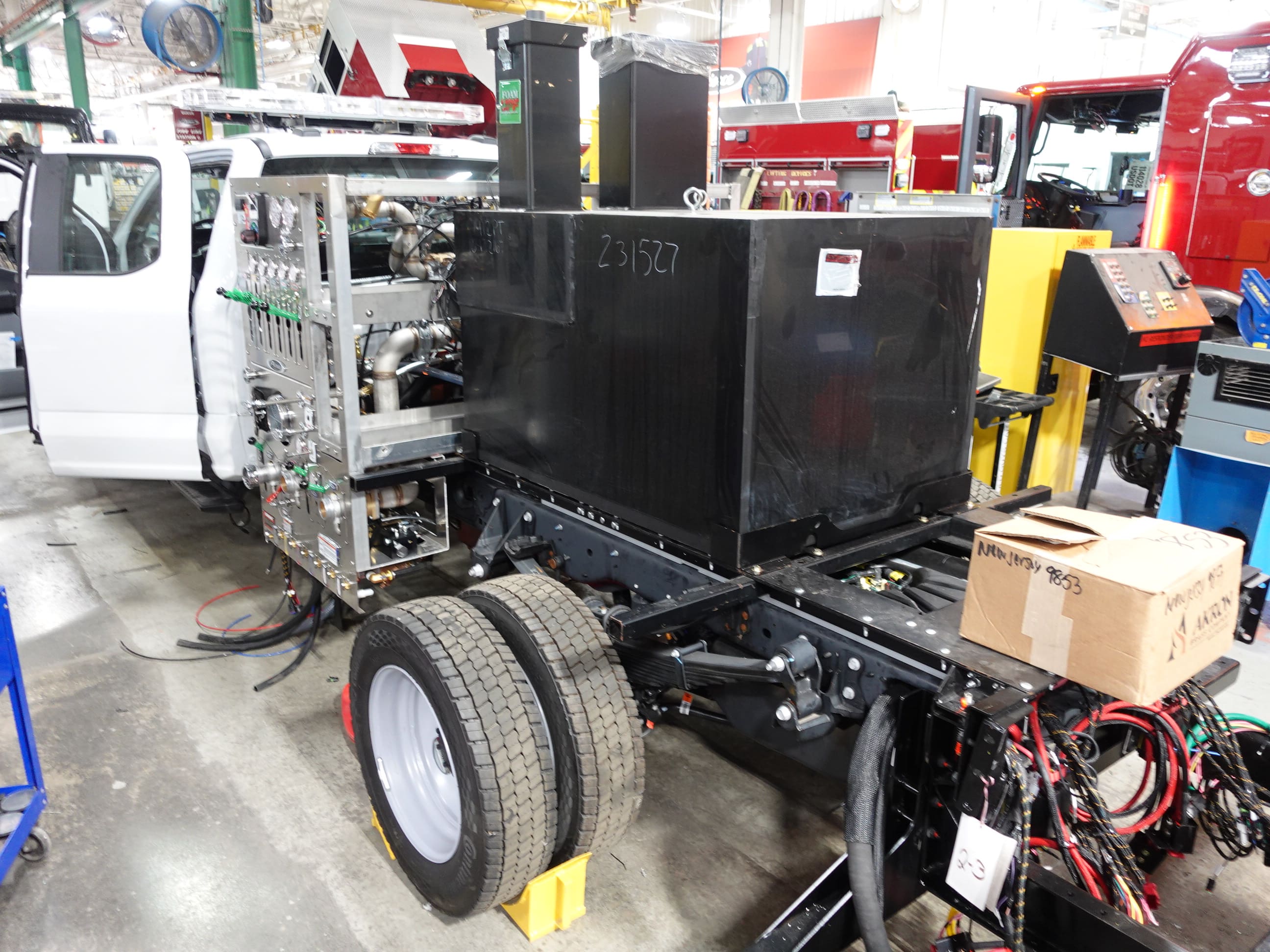

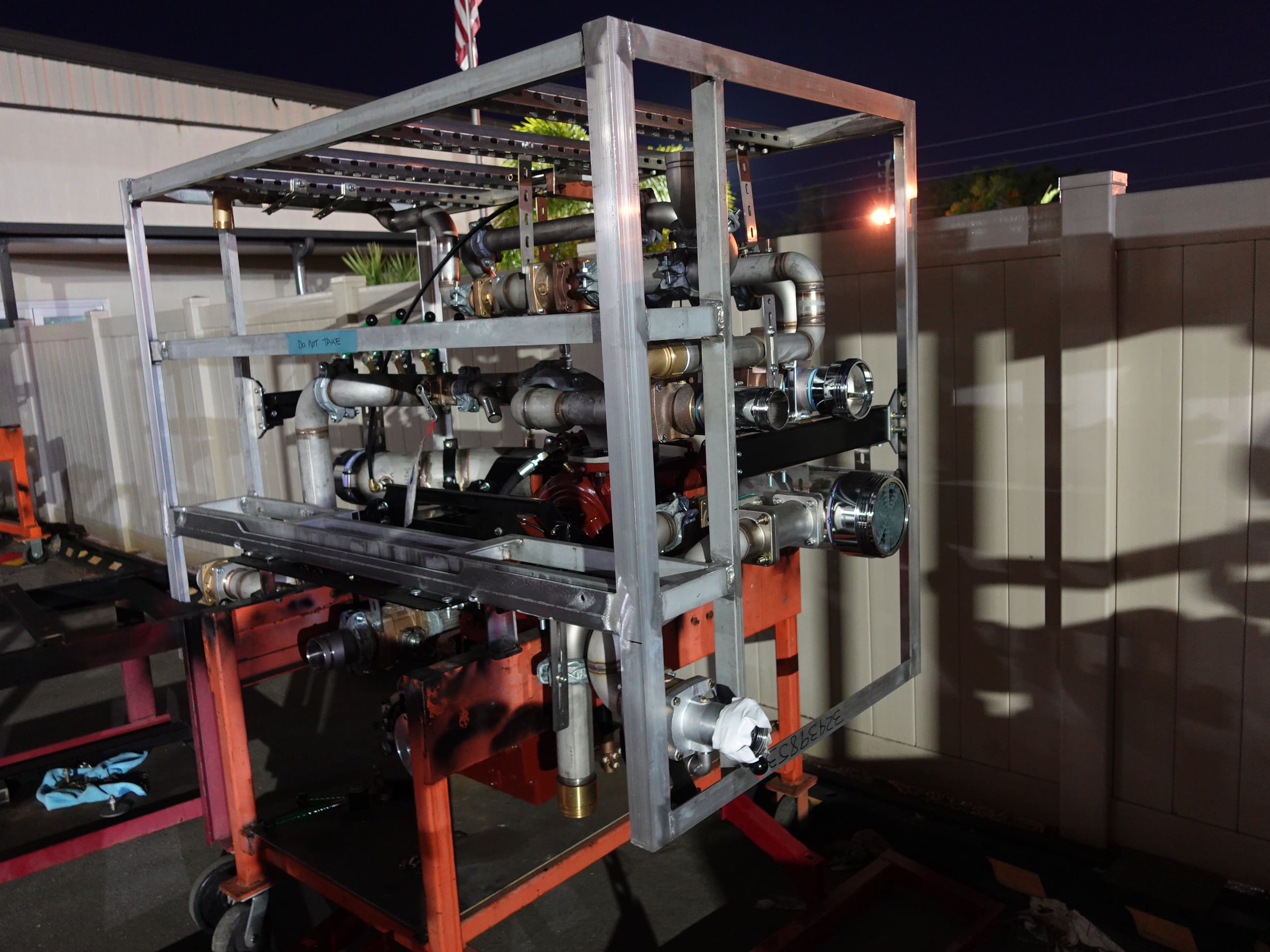

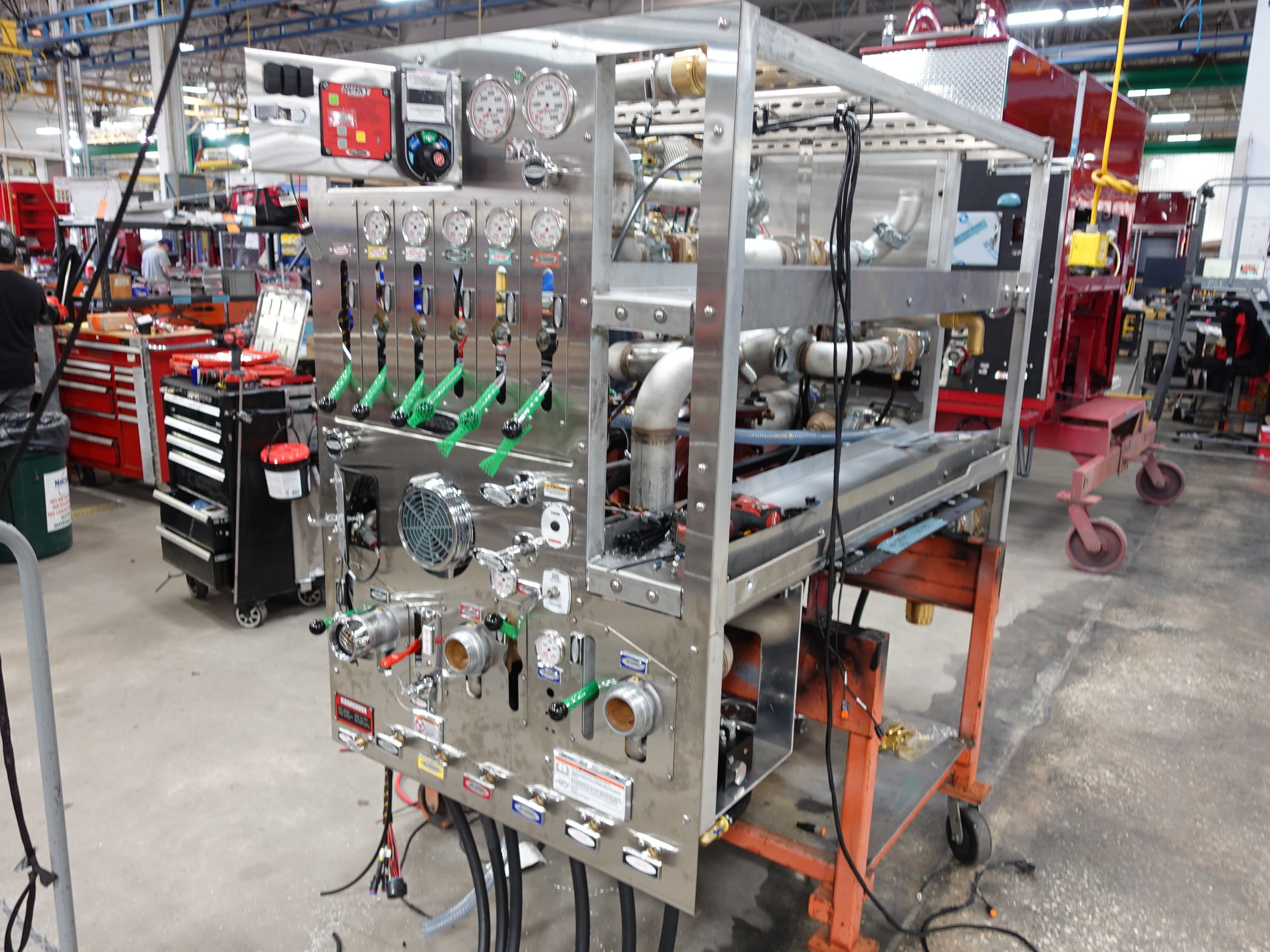

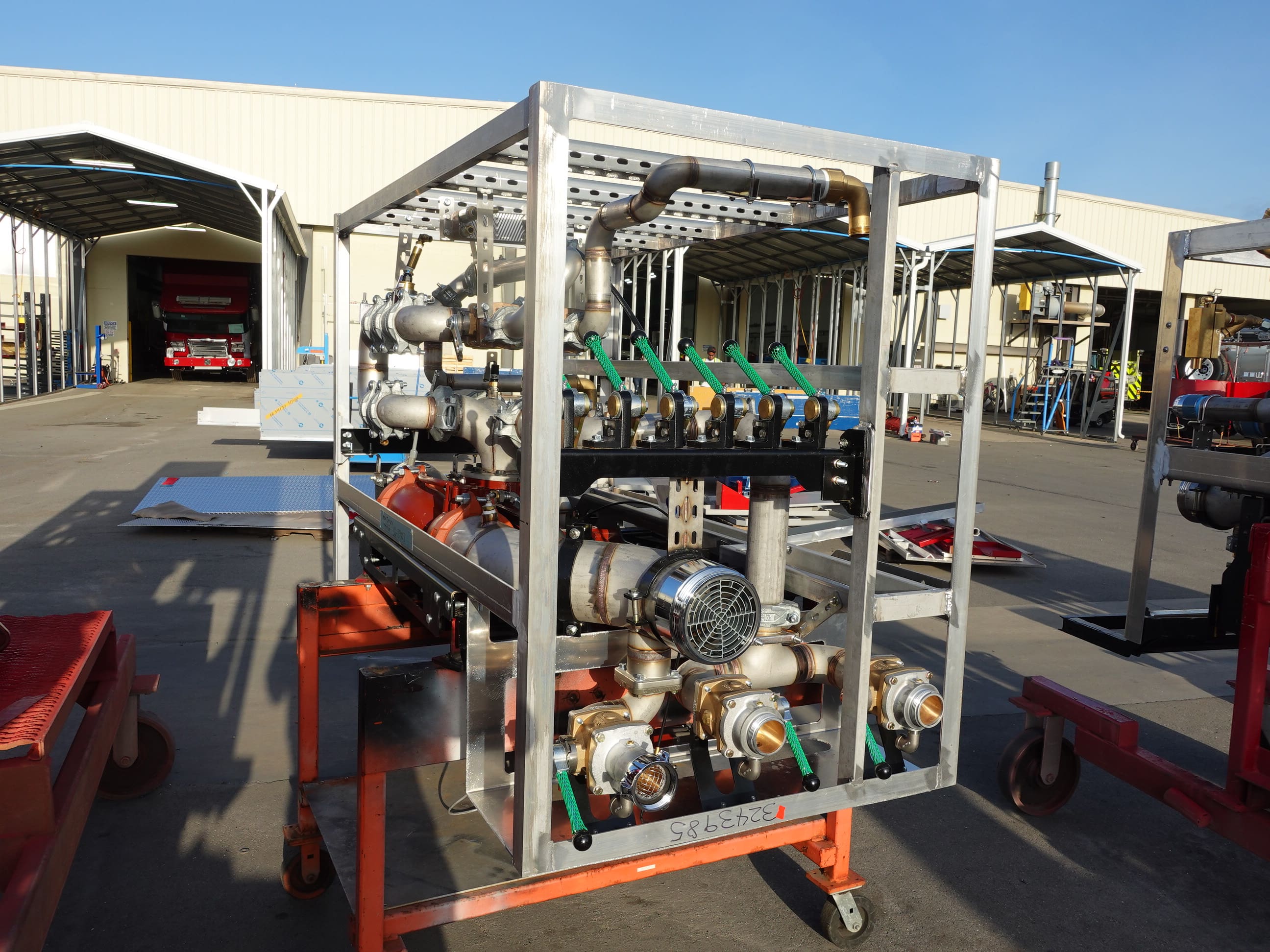

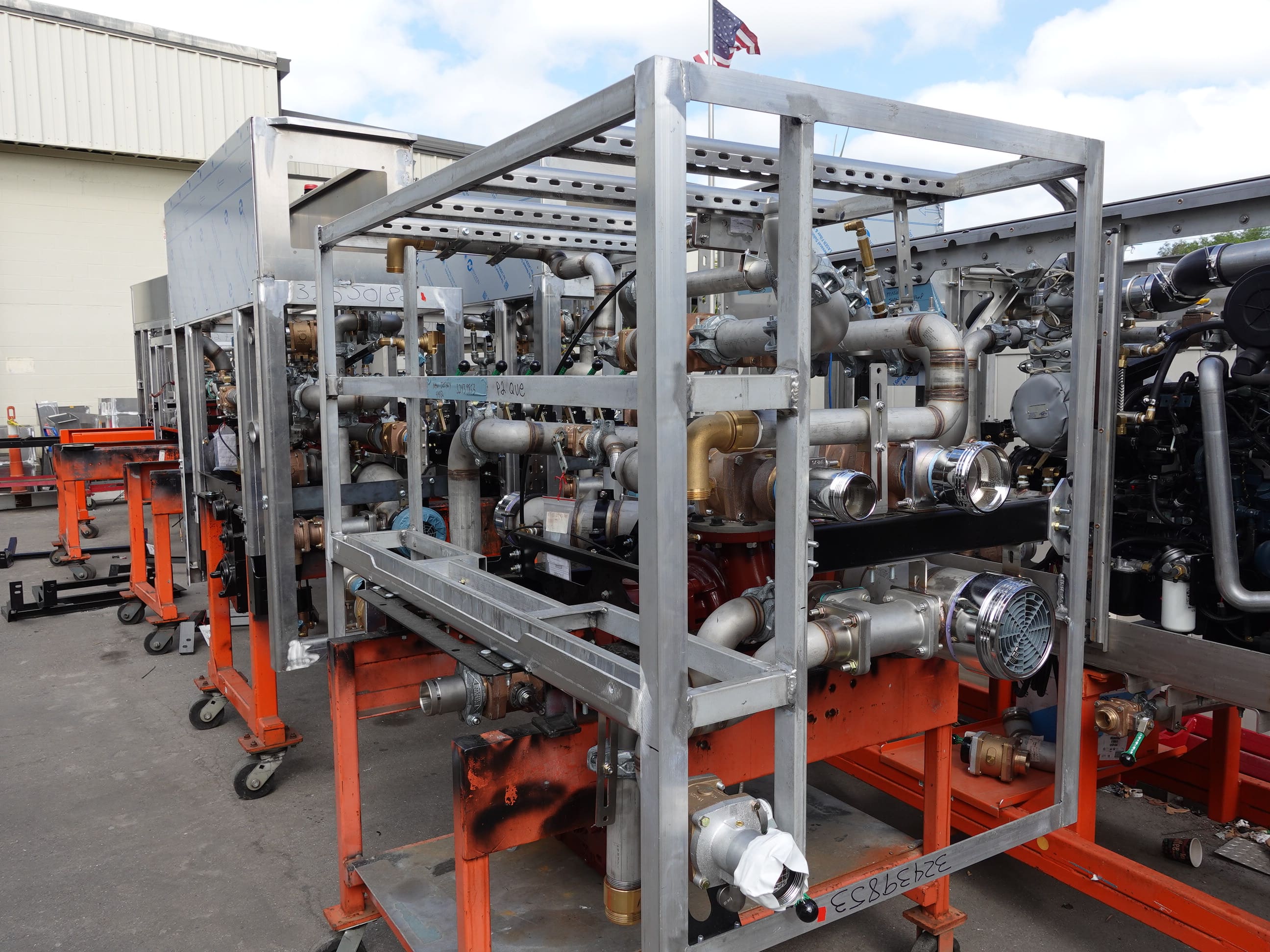

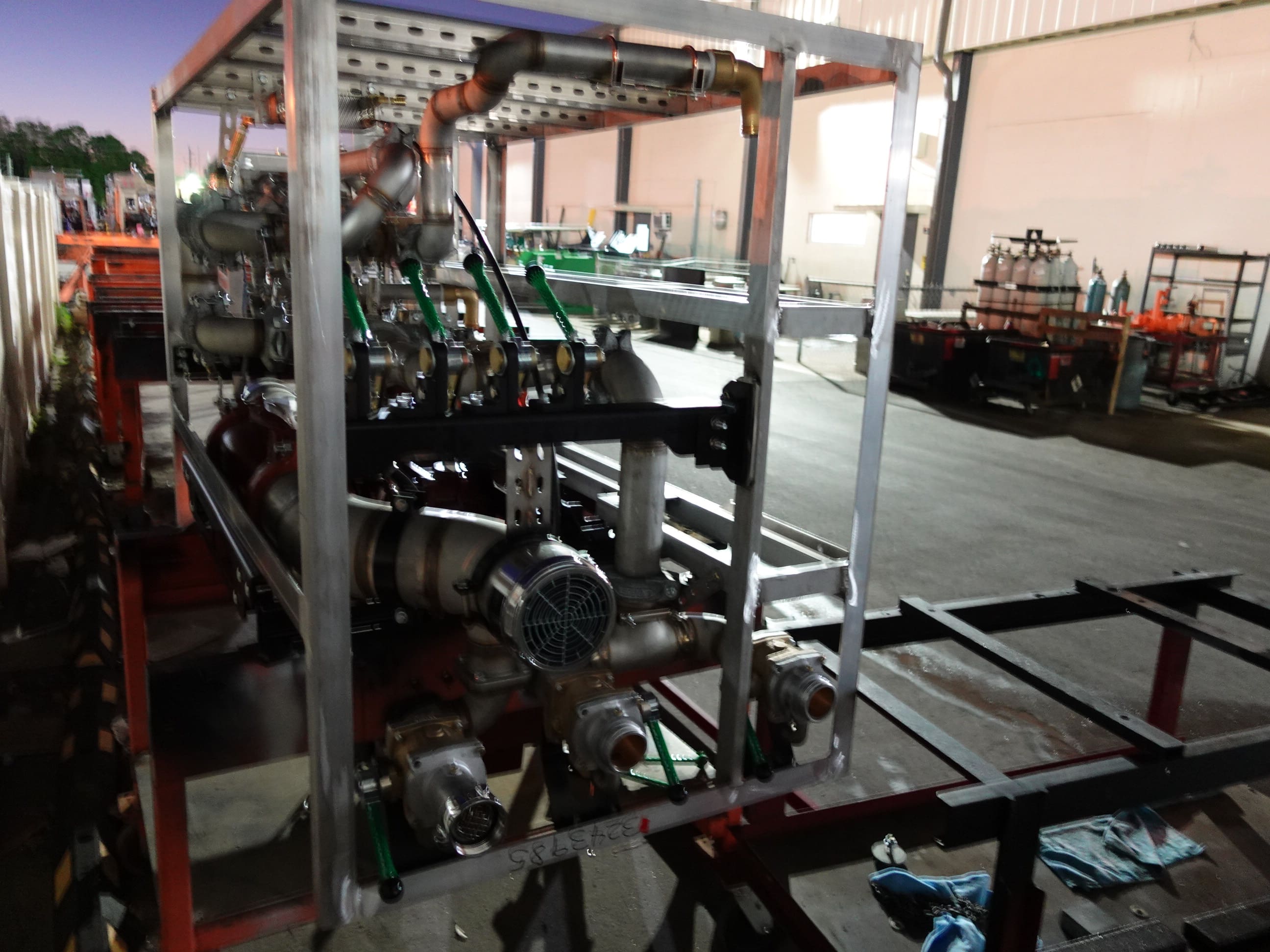

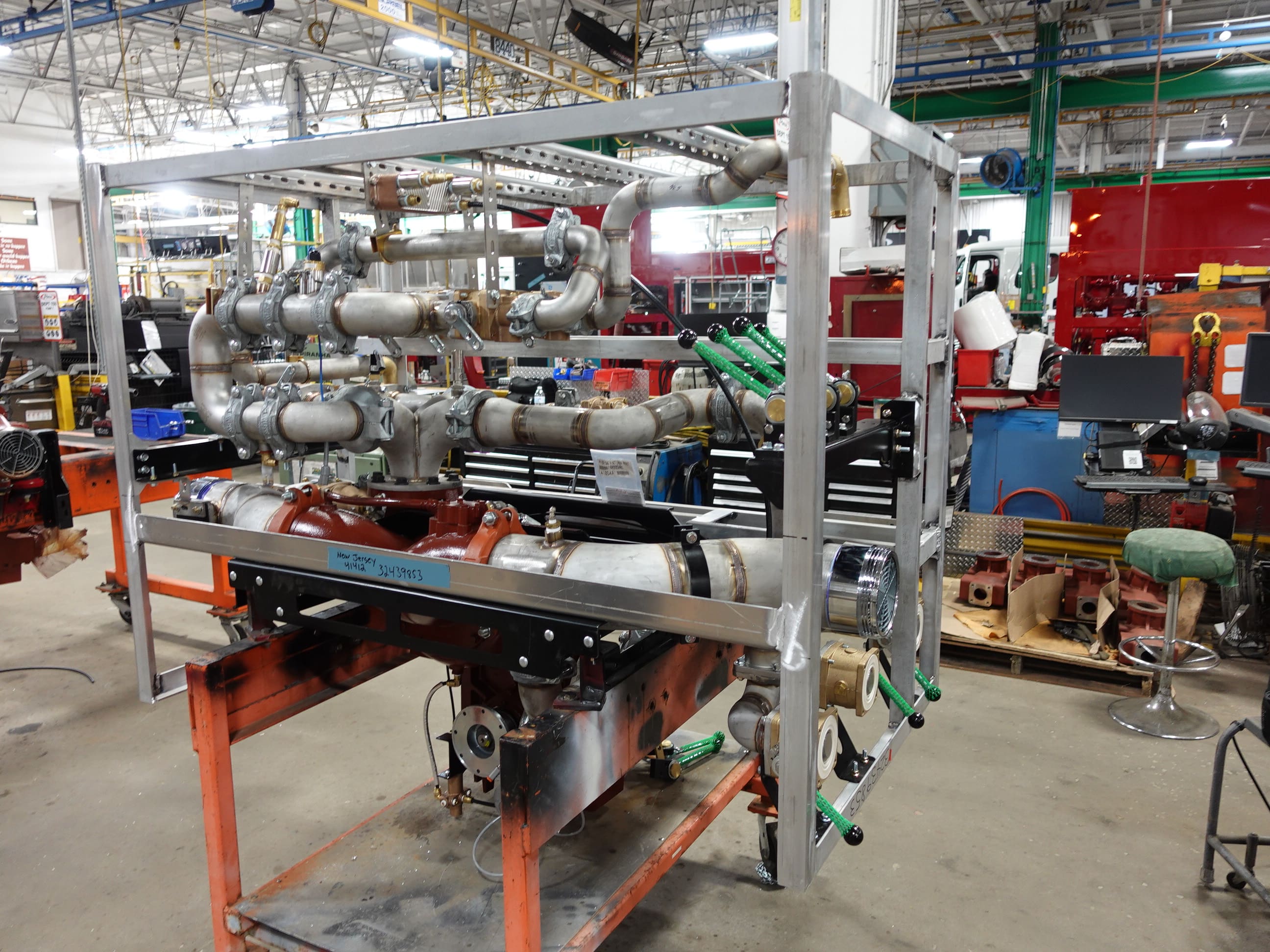

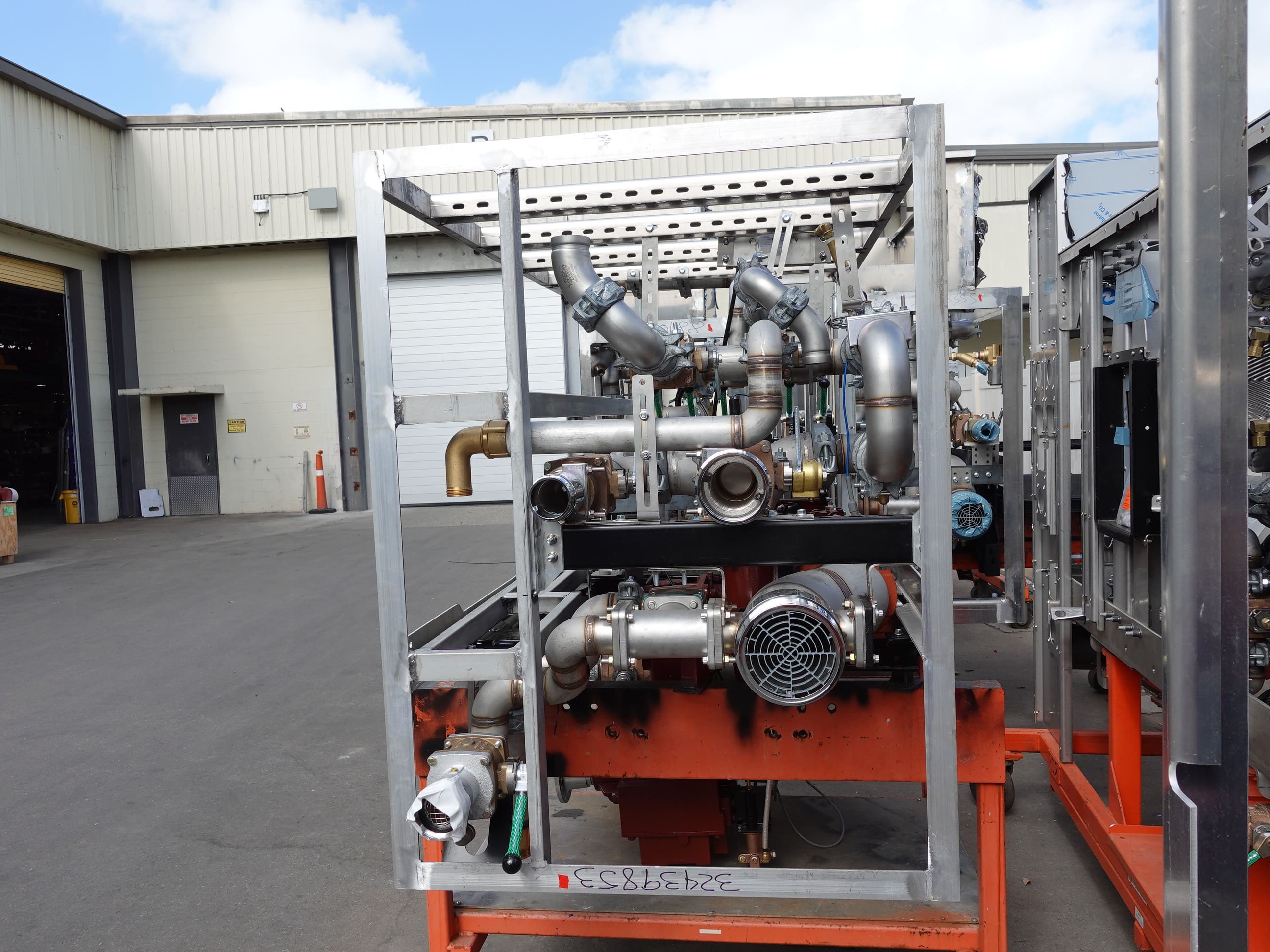

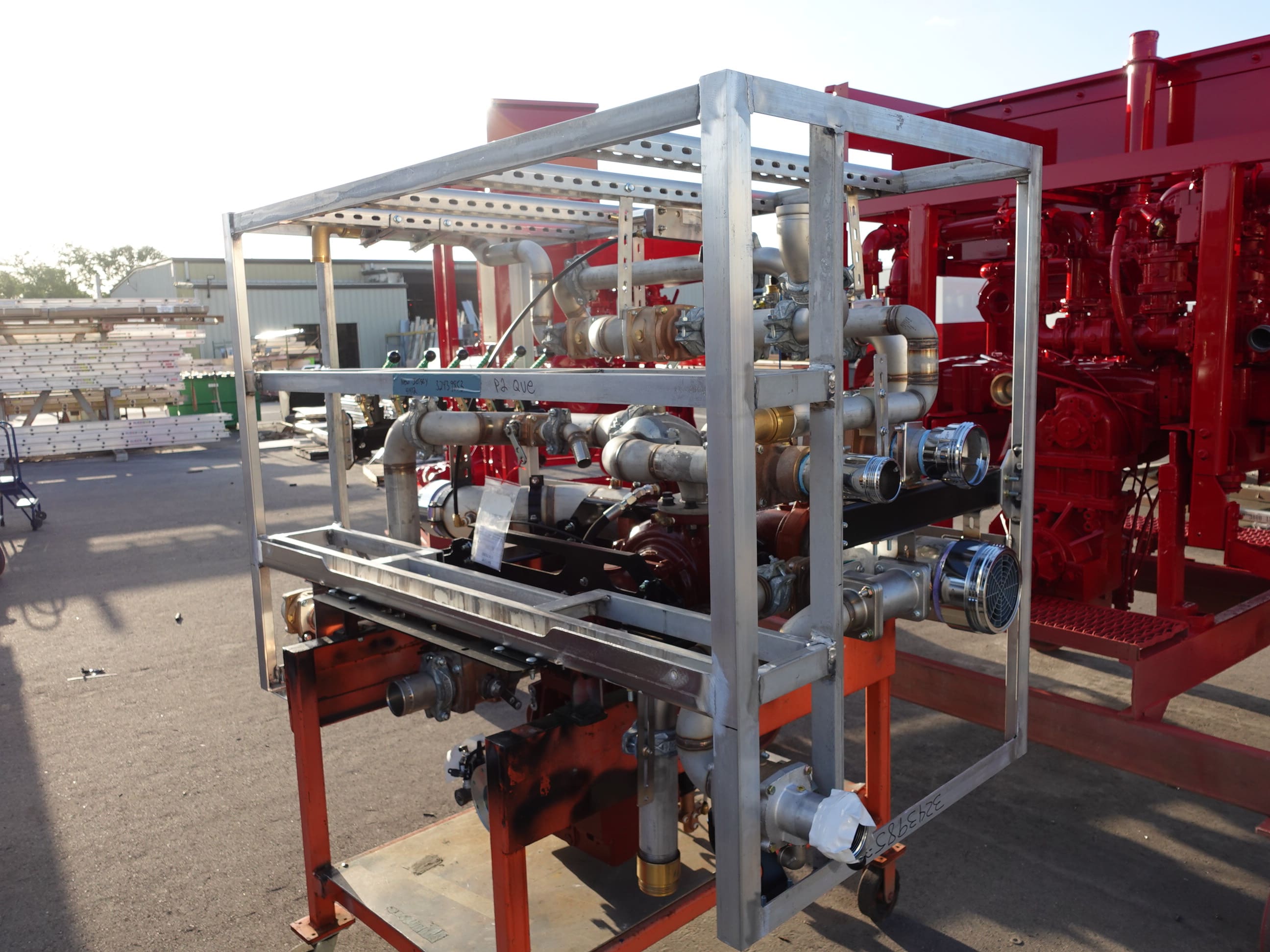

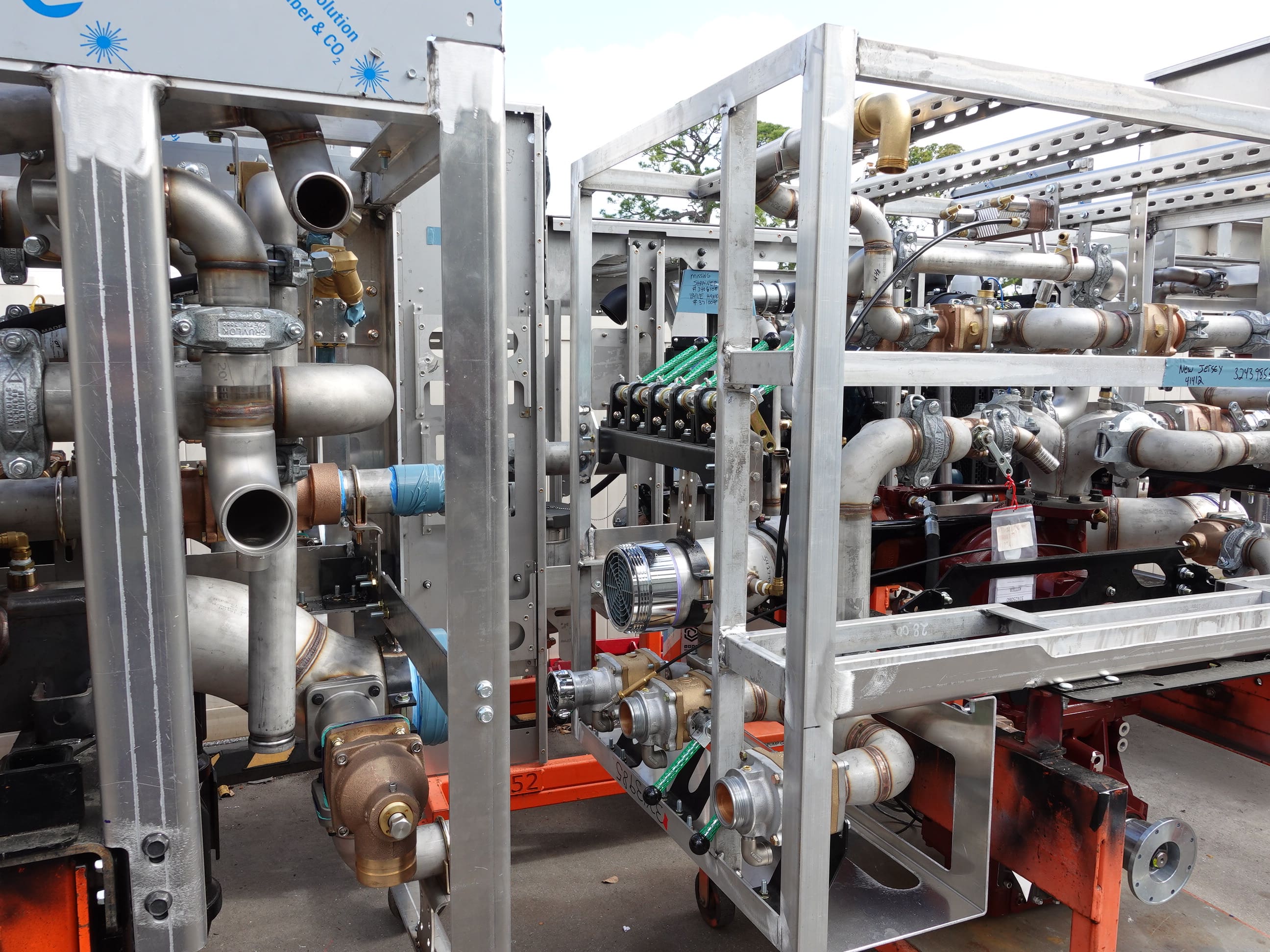

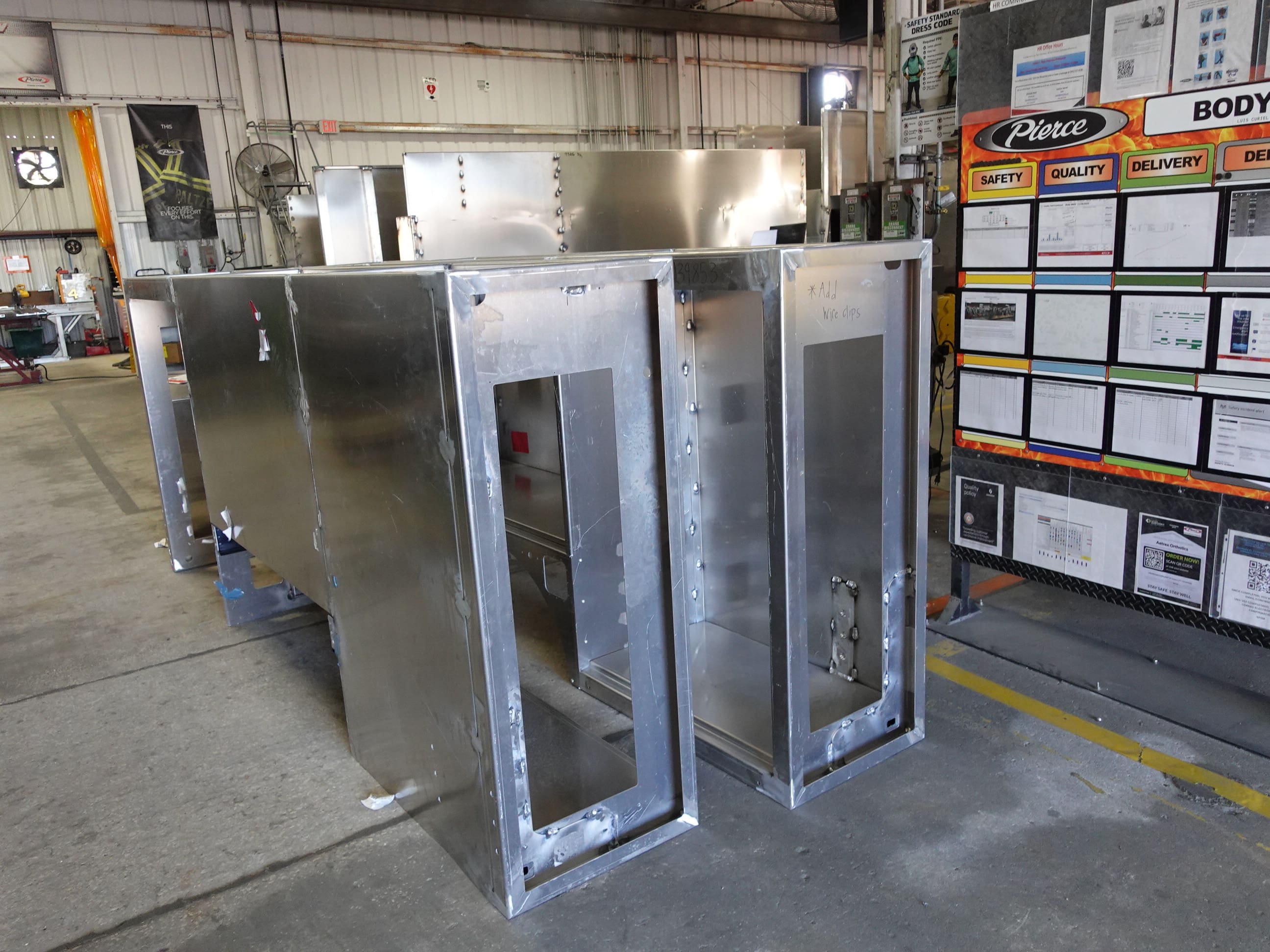

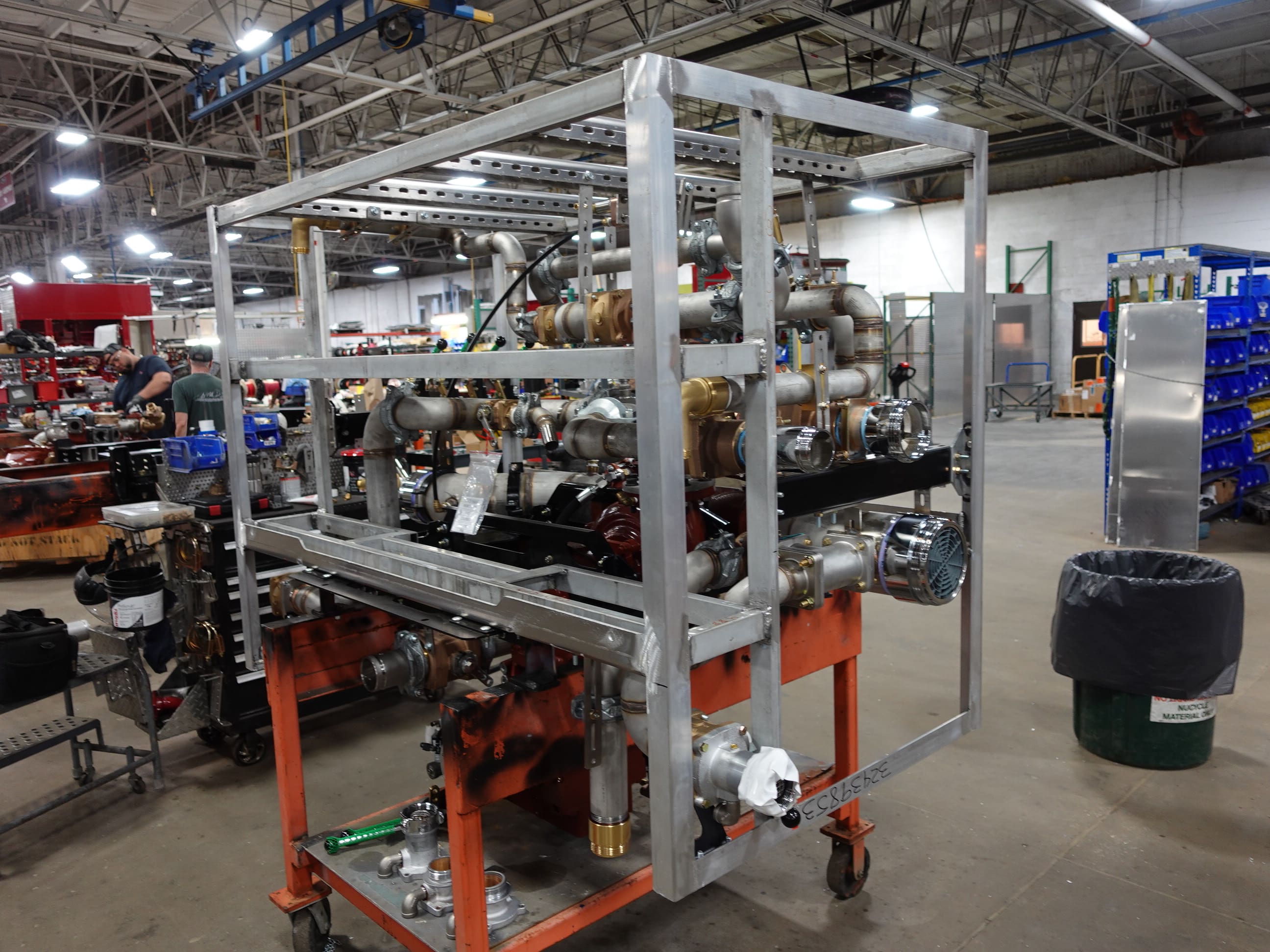

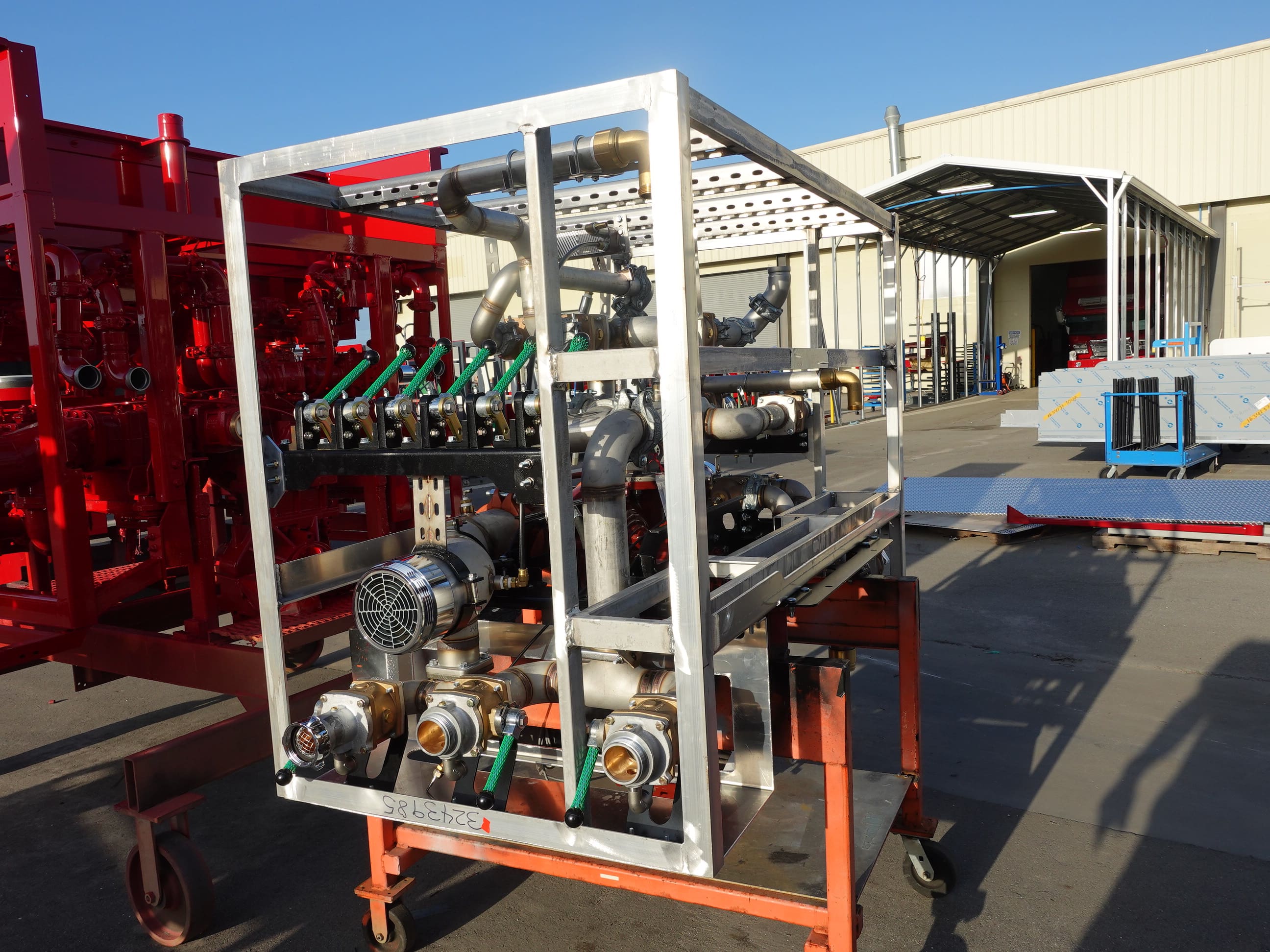

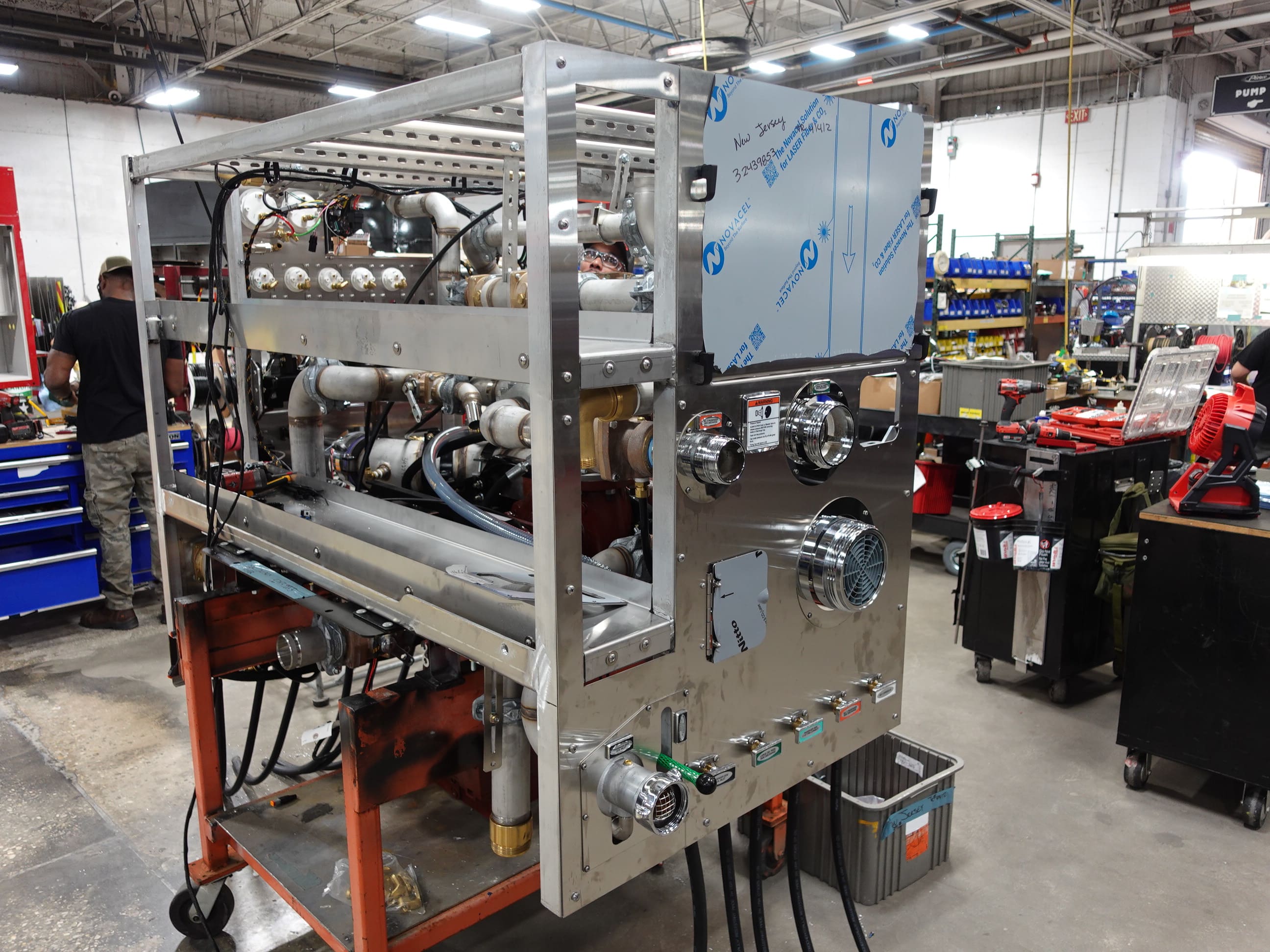

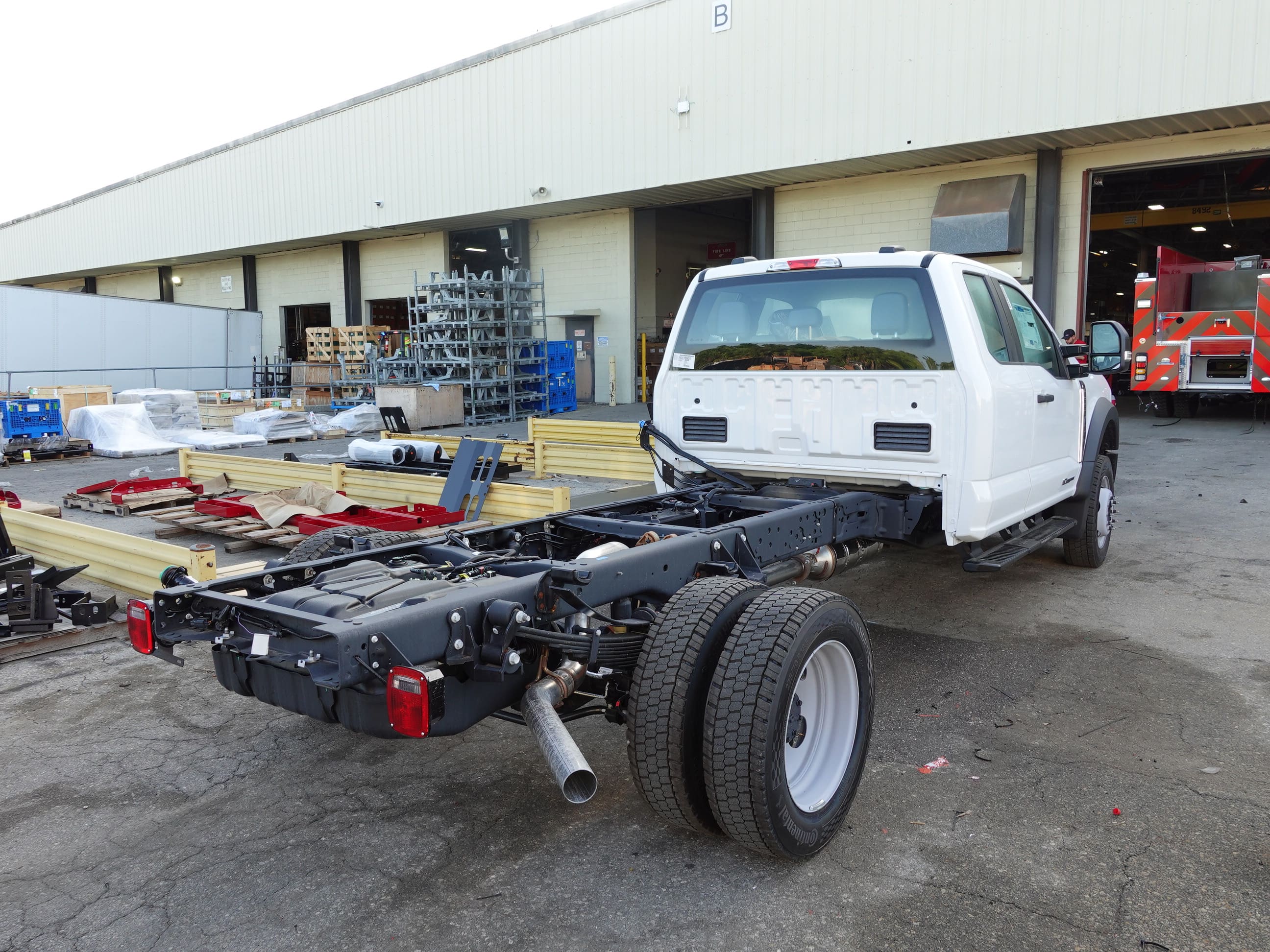

In this report, the pump house and the tank were merged with the chassis while the body continued initial assembly.
04-17-26

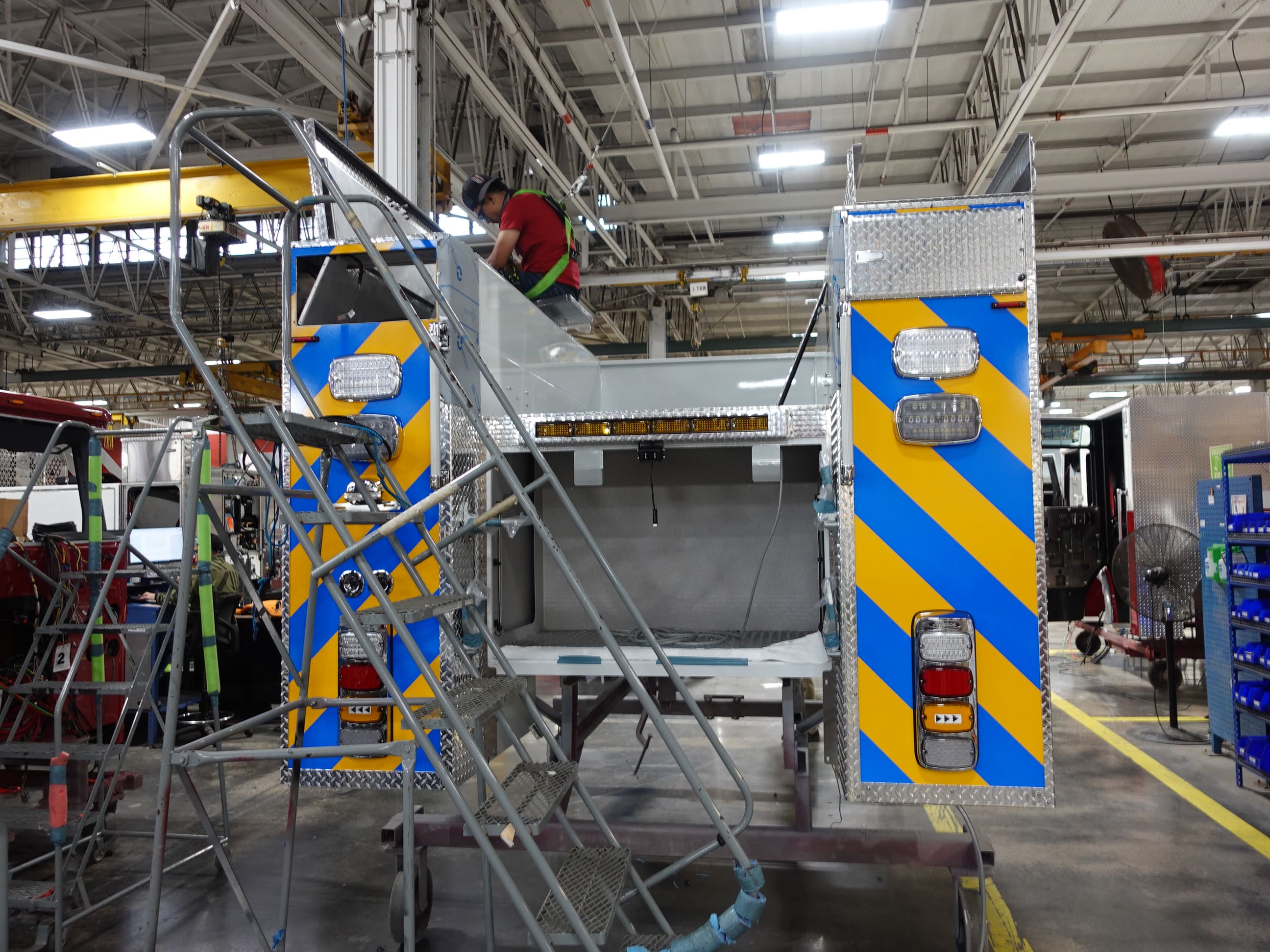

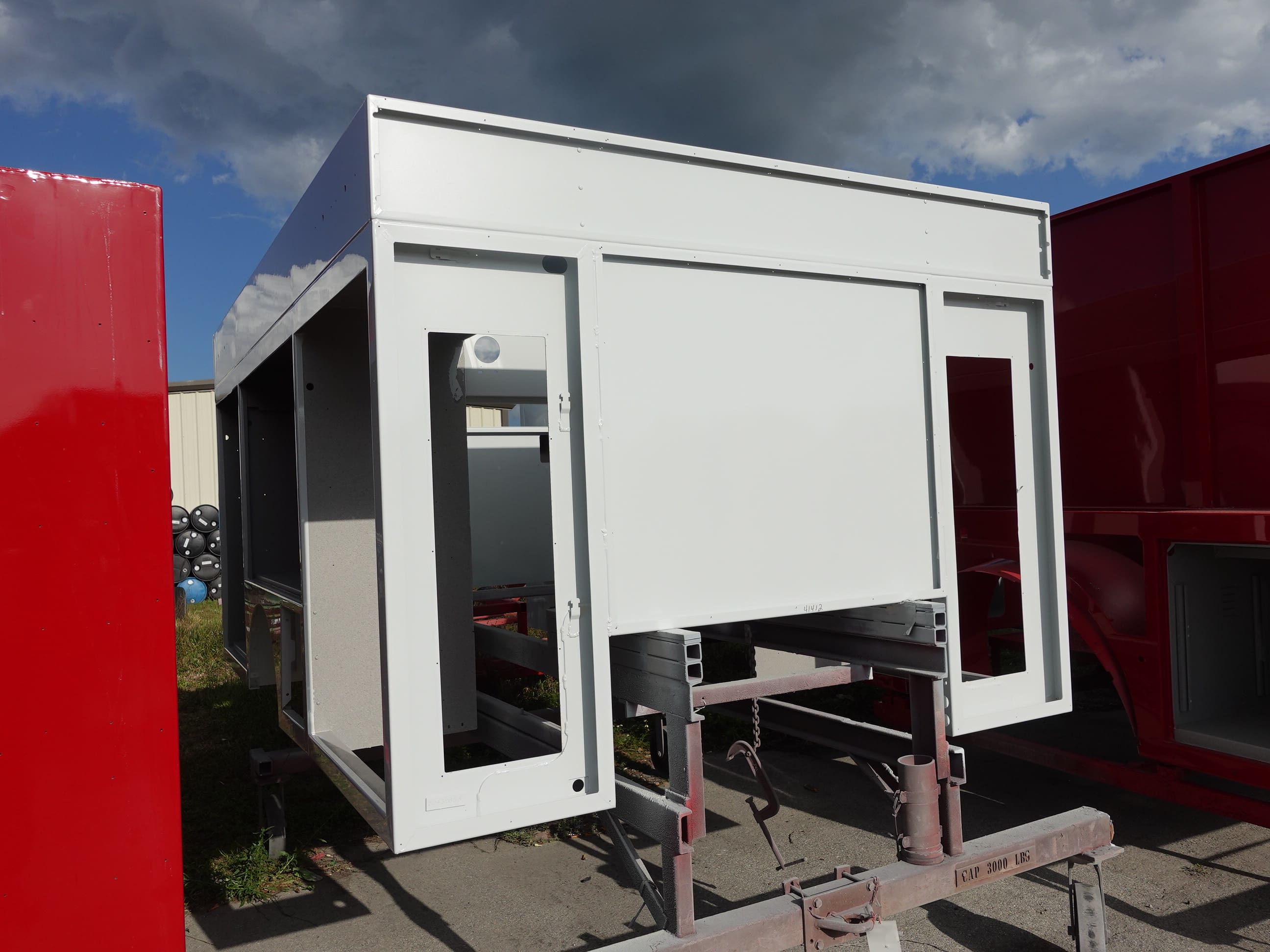

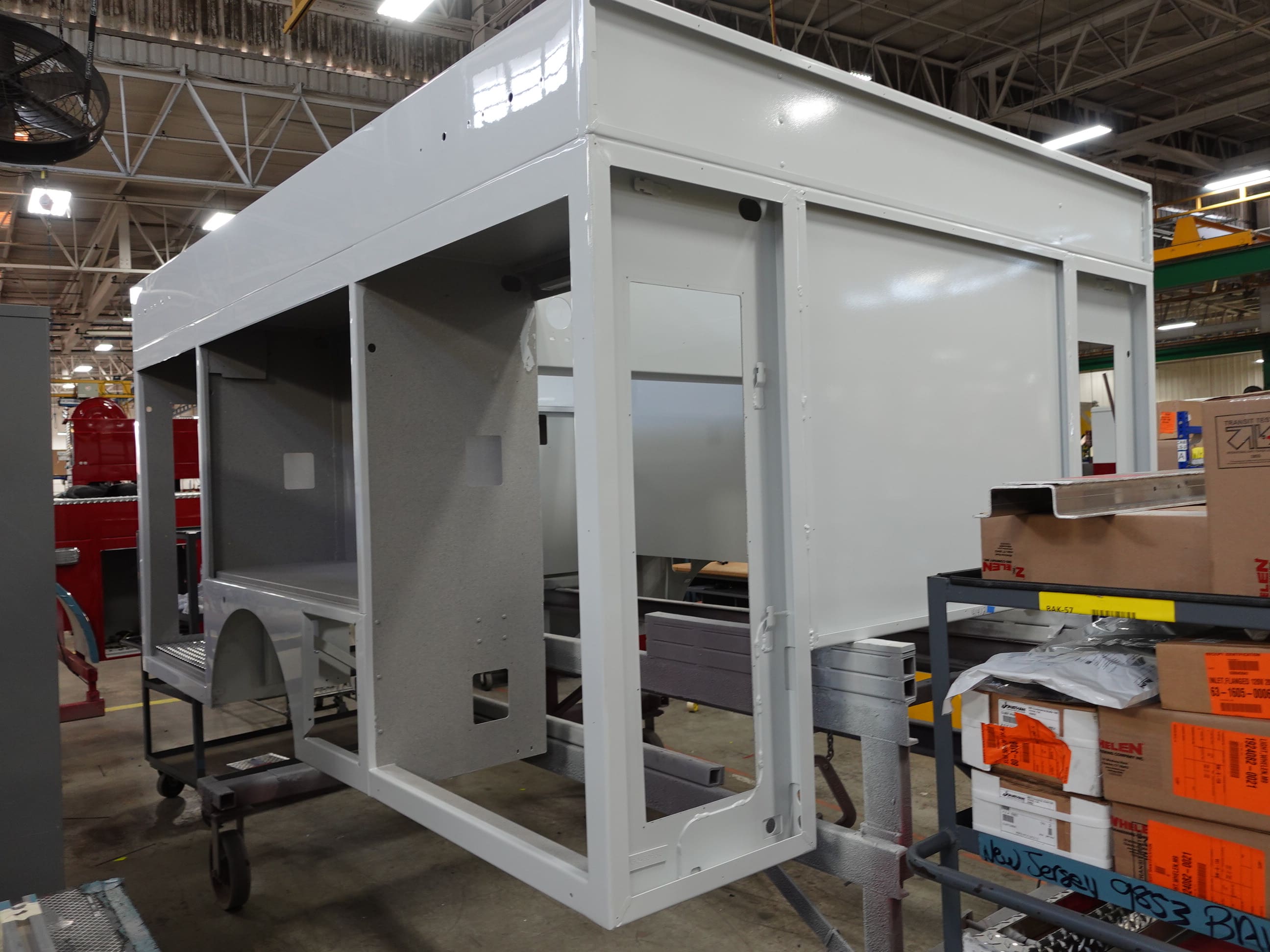

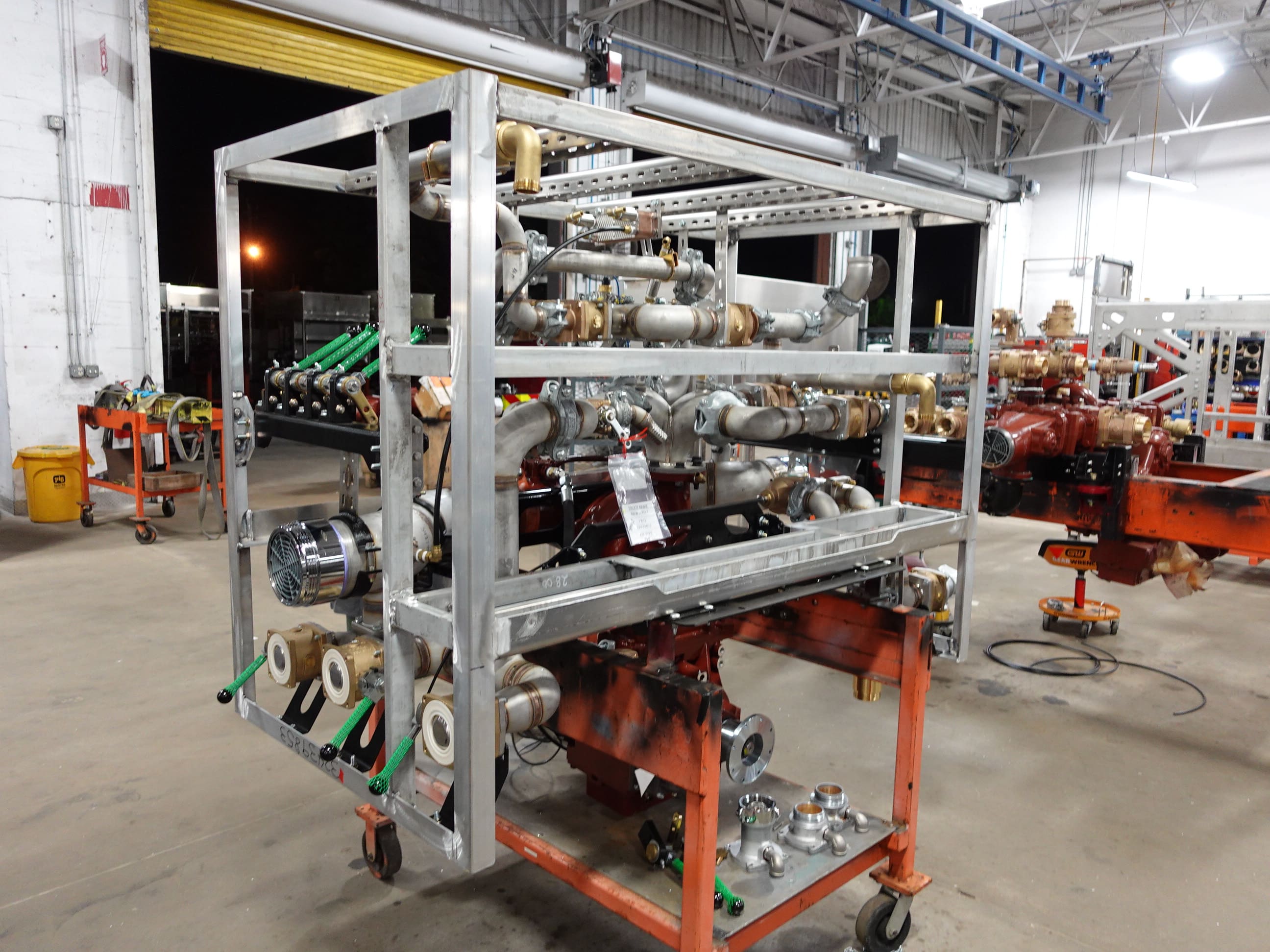

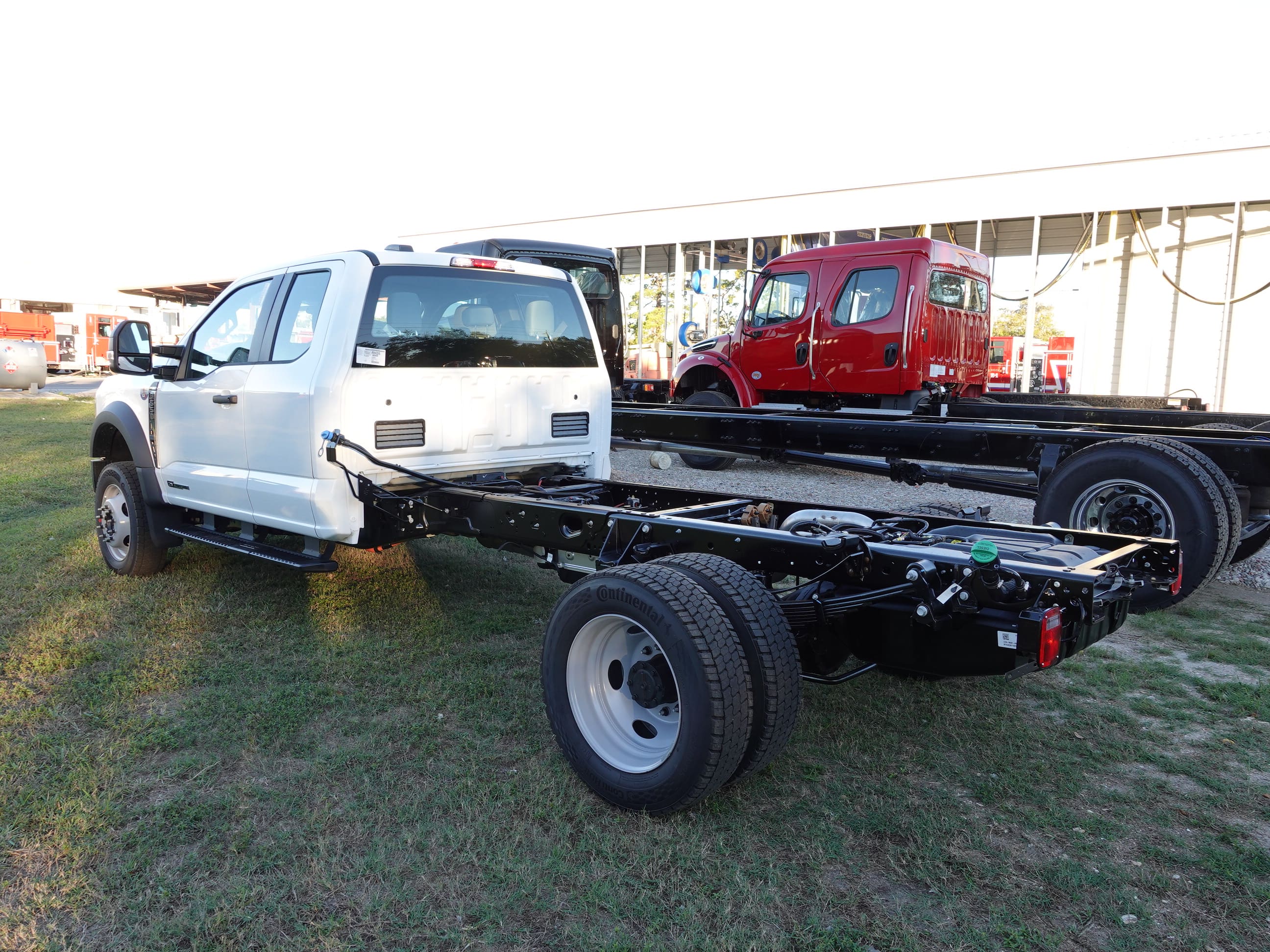

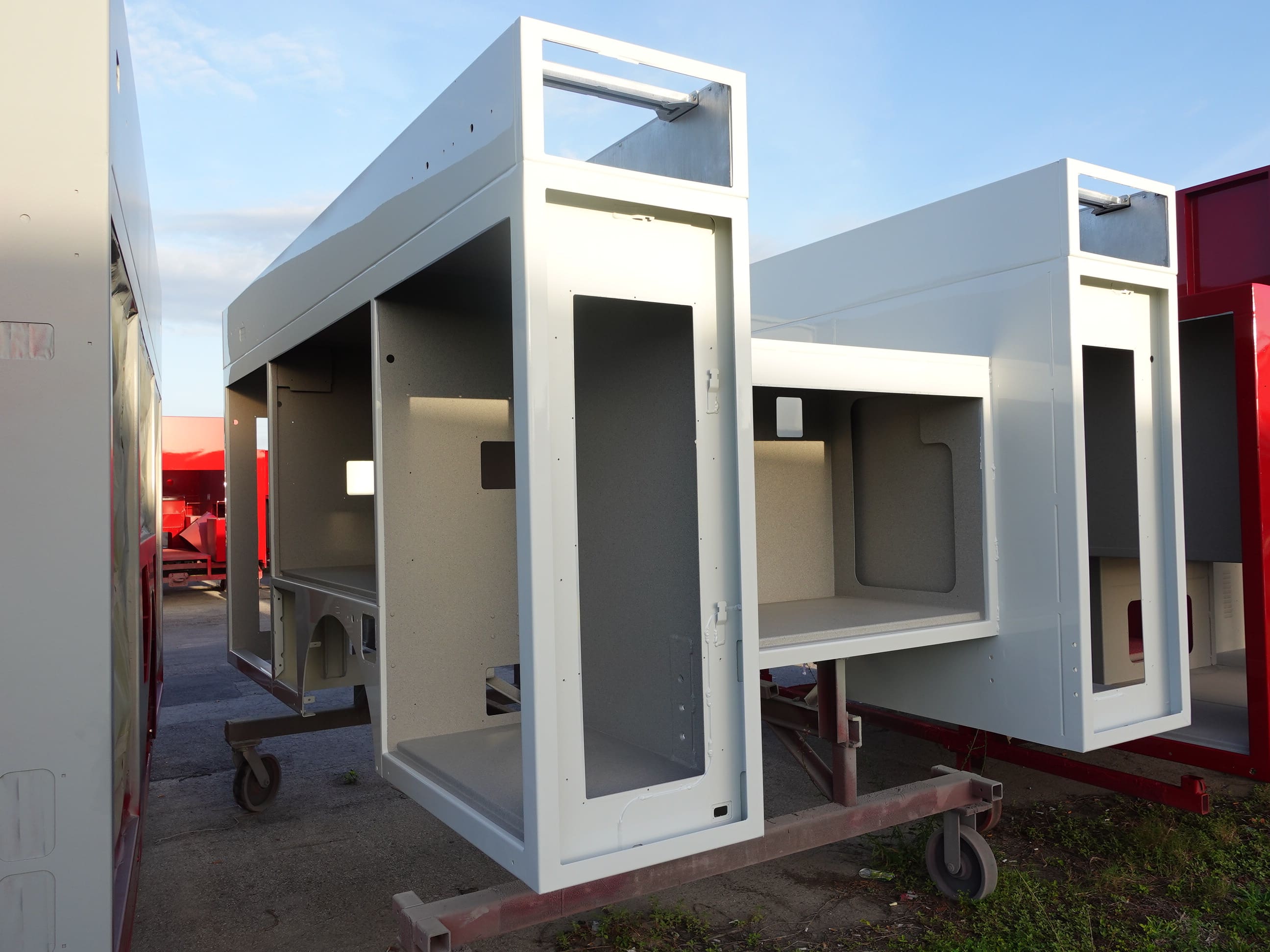

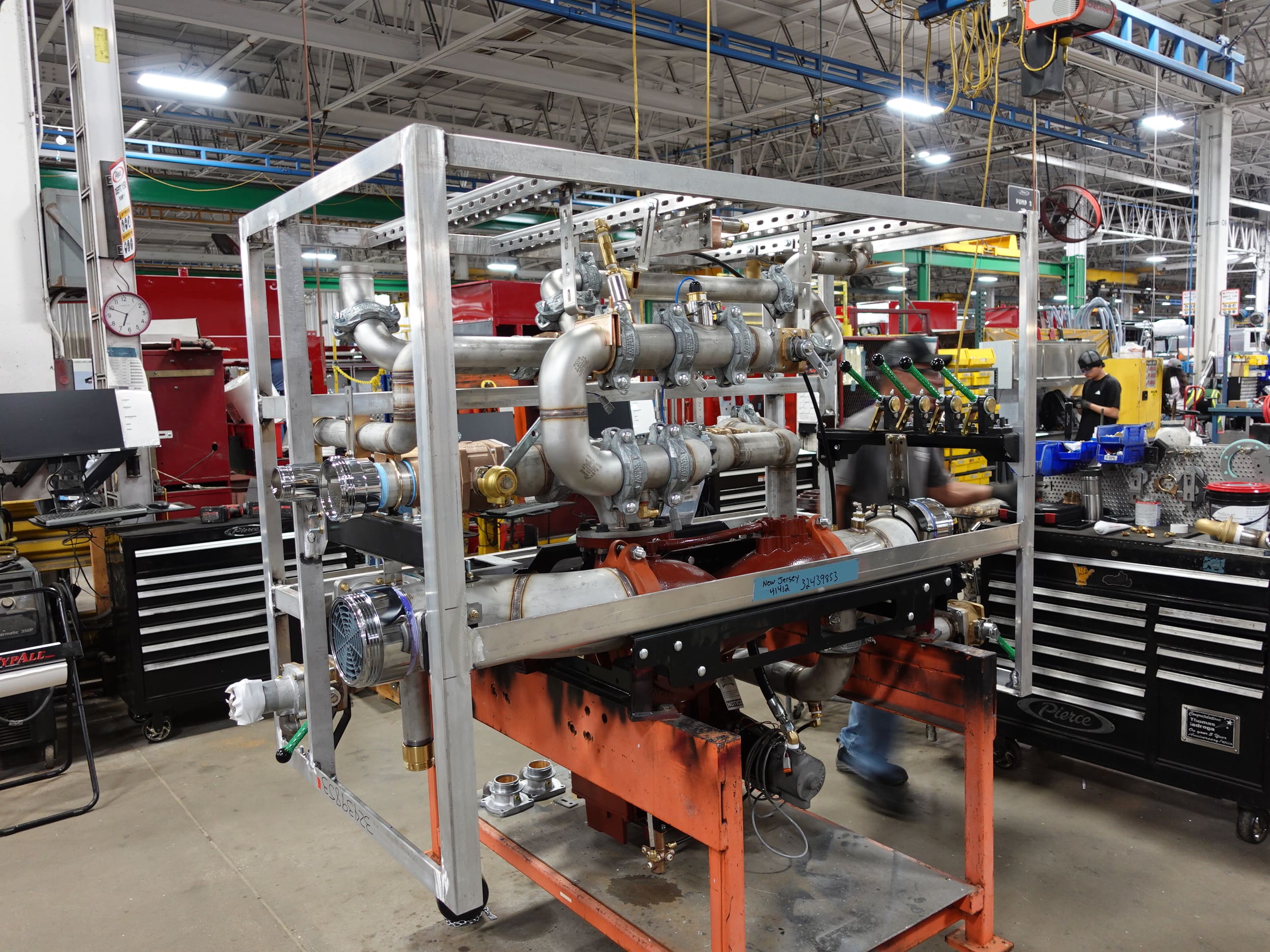

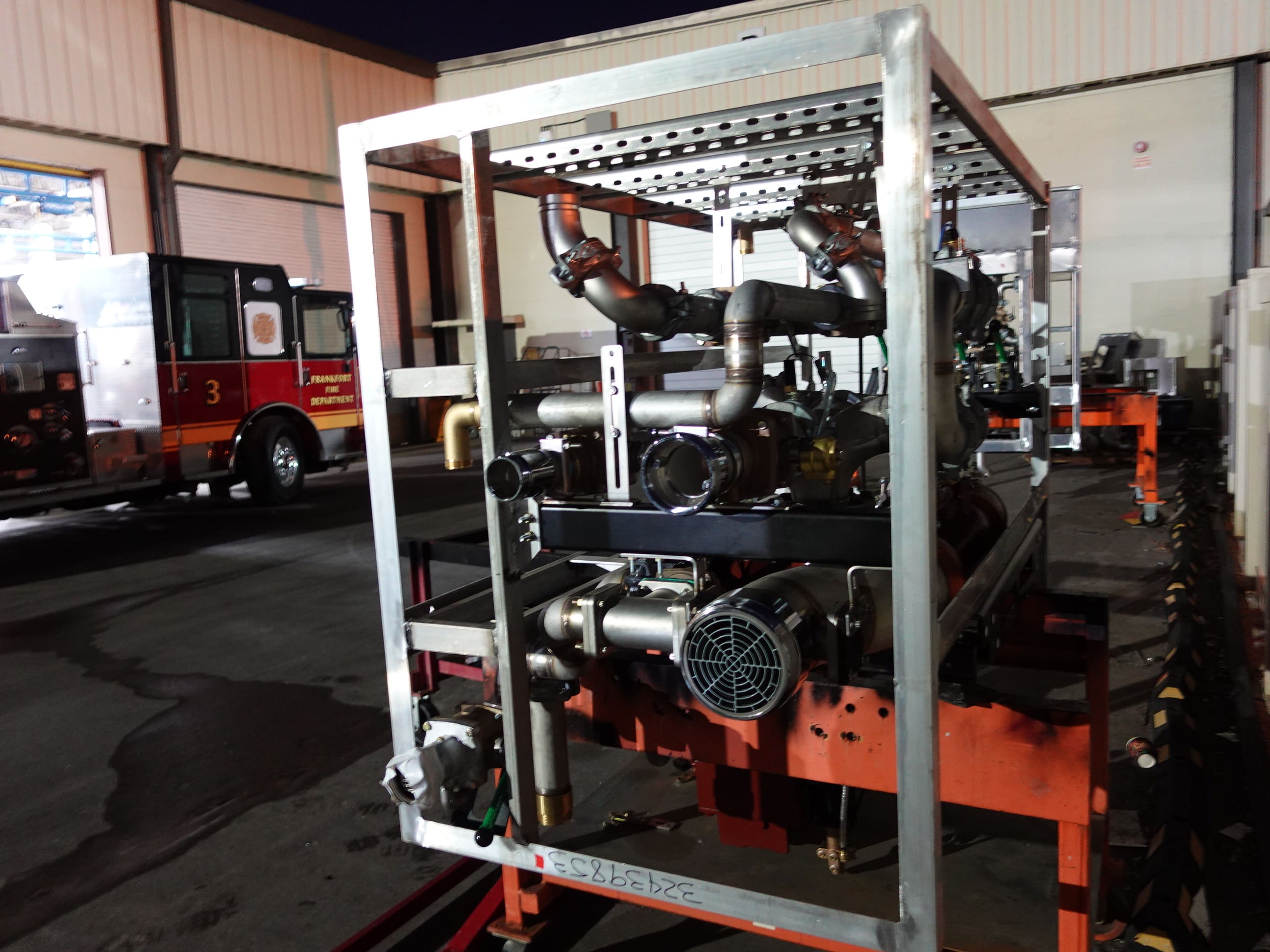

In this report, the chassis continued preparations for fire and emergency use, the pump house continued initial assembly, and the body began initial assembly.
04-10-26

In this report, the commercial chassis began preparations for fire and emergency use, the pump house was staged to continue initial assembly, and the body remained staged.
04-03-26

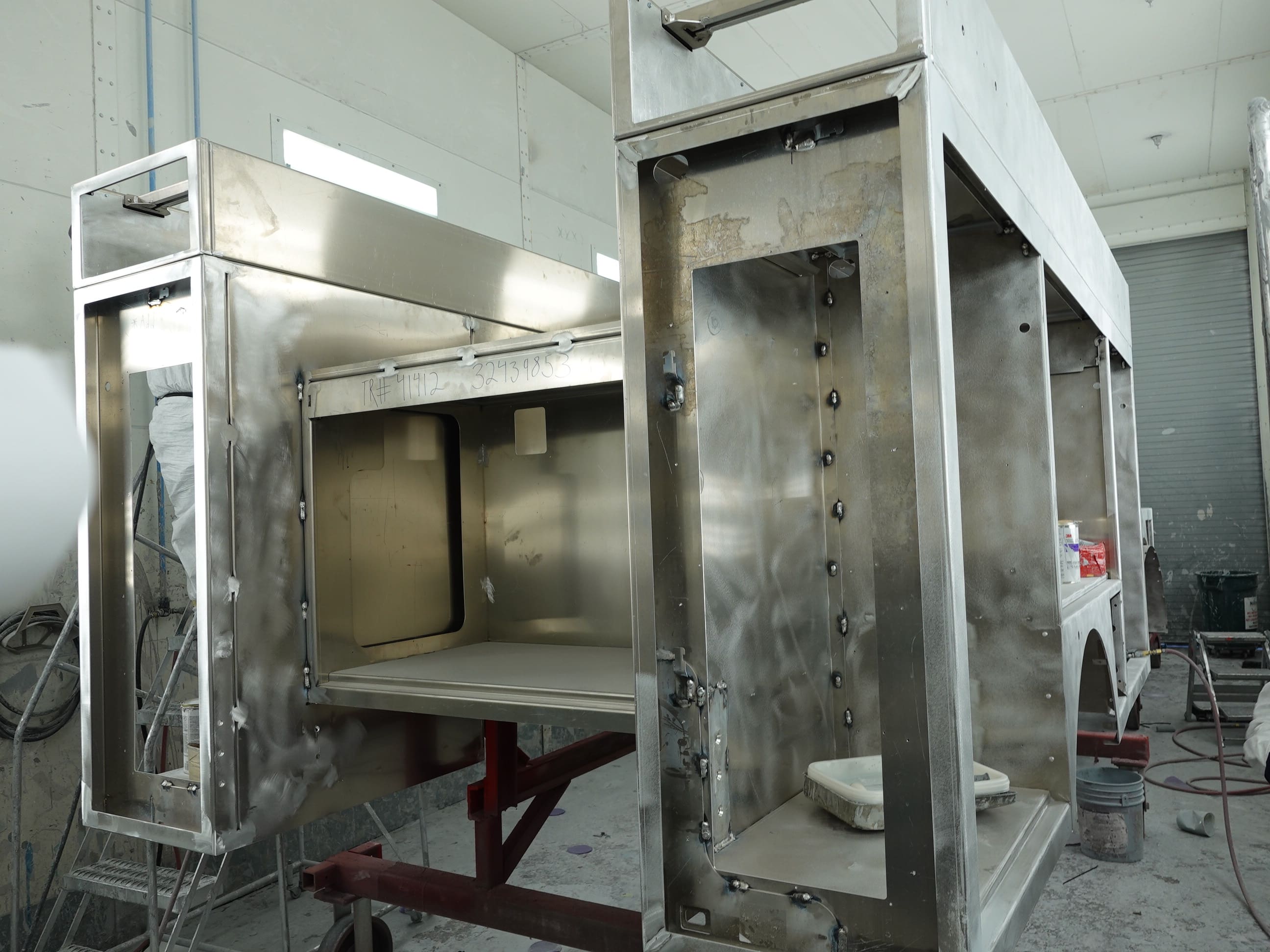

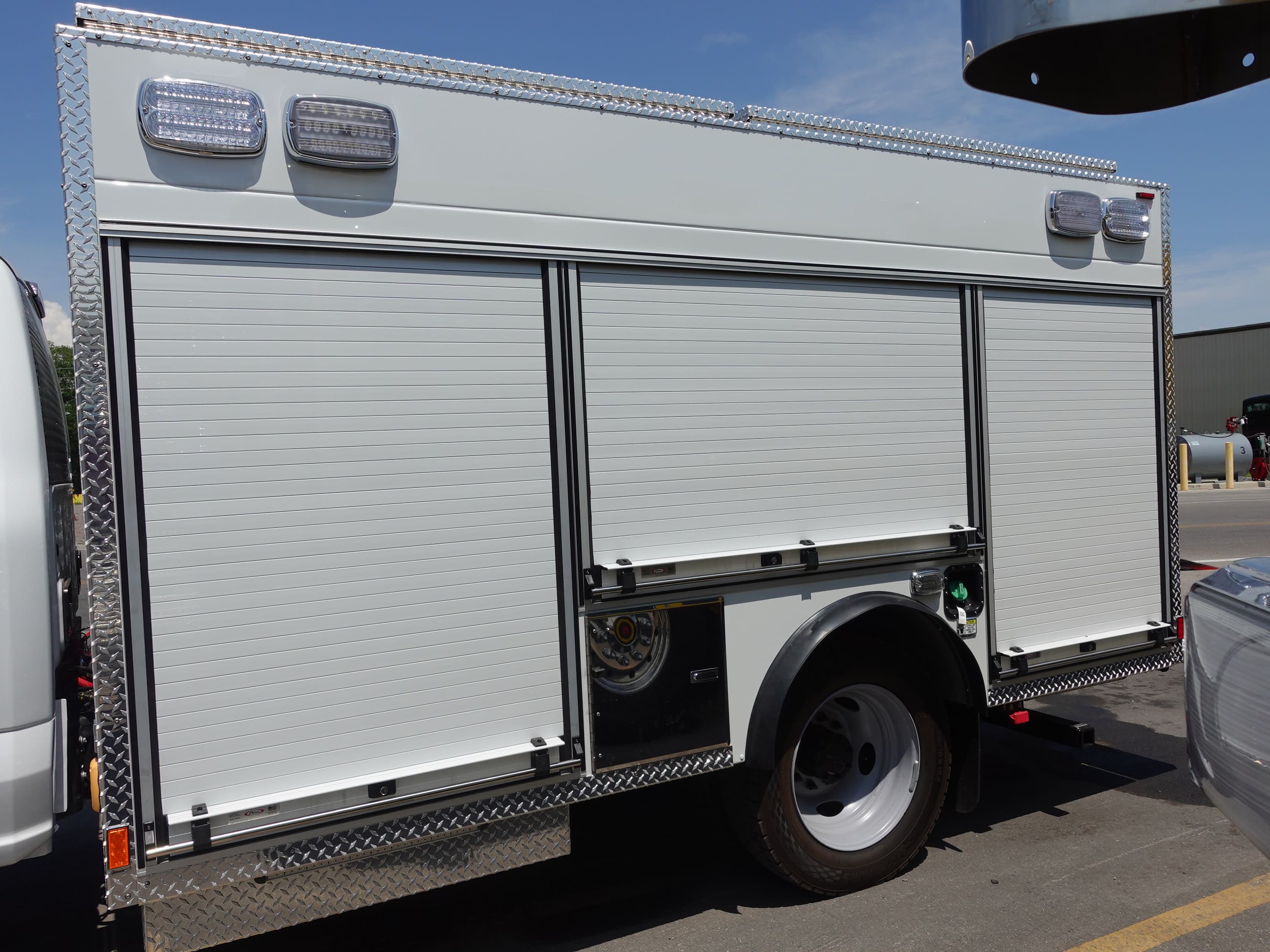

In this report, the chassis remained staged (no photos), the pump house continued initial assembly, and the body completed paint.
03-27-26

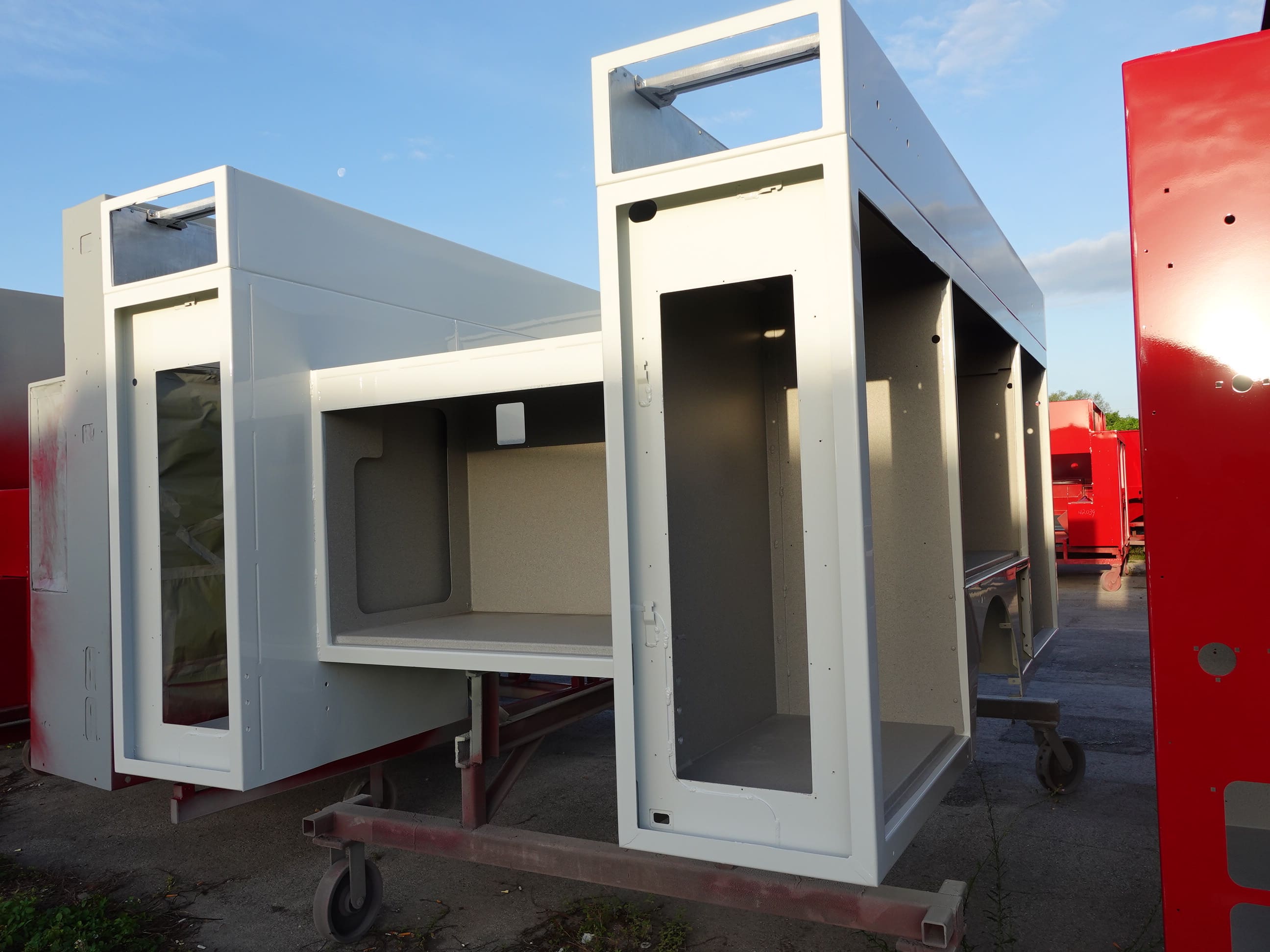

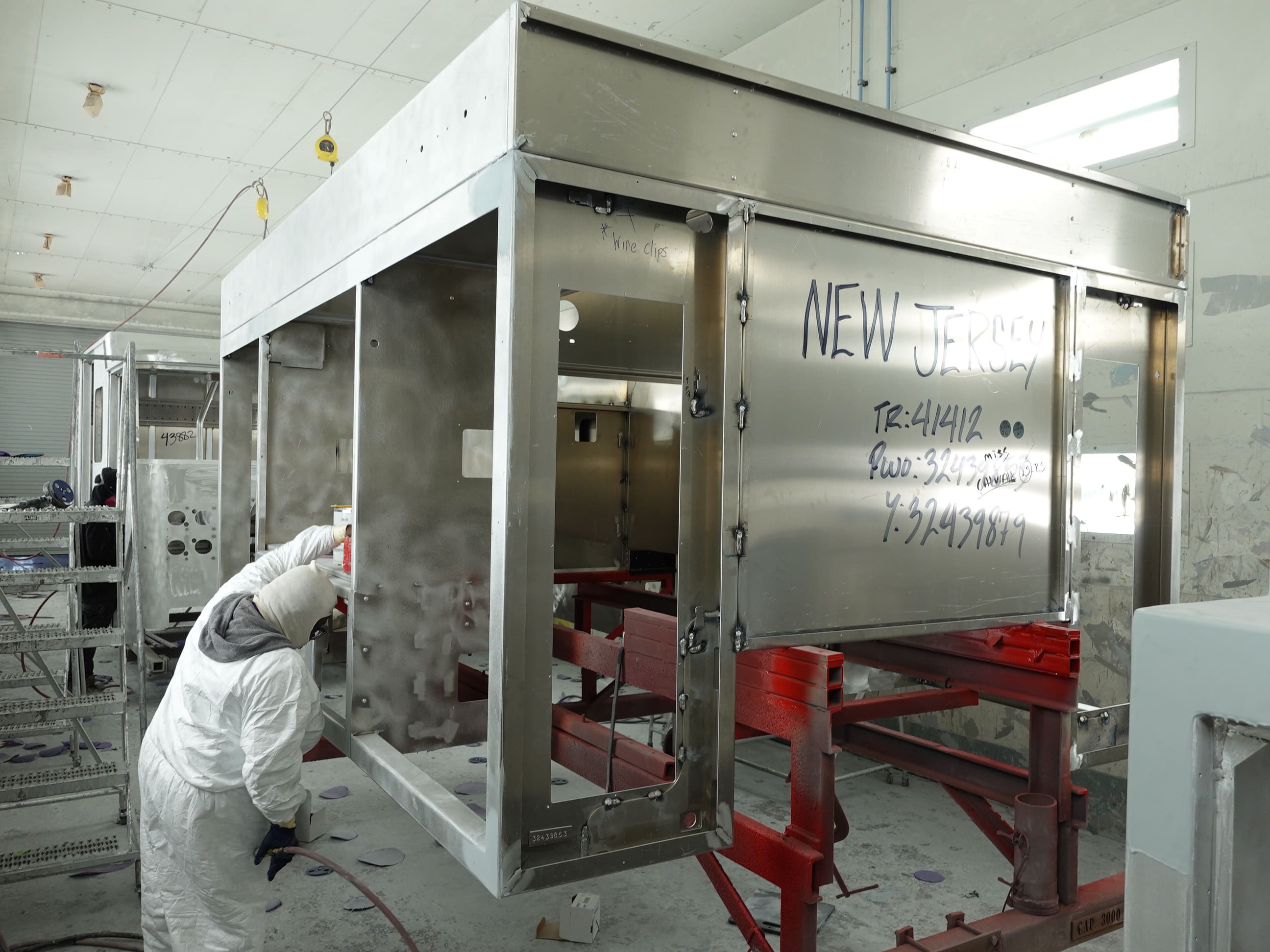

In this report, the chassis was staged (no photos), the pump house continued initial assembly, and the body completed fabrication and began the paint process.
03-20-26

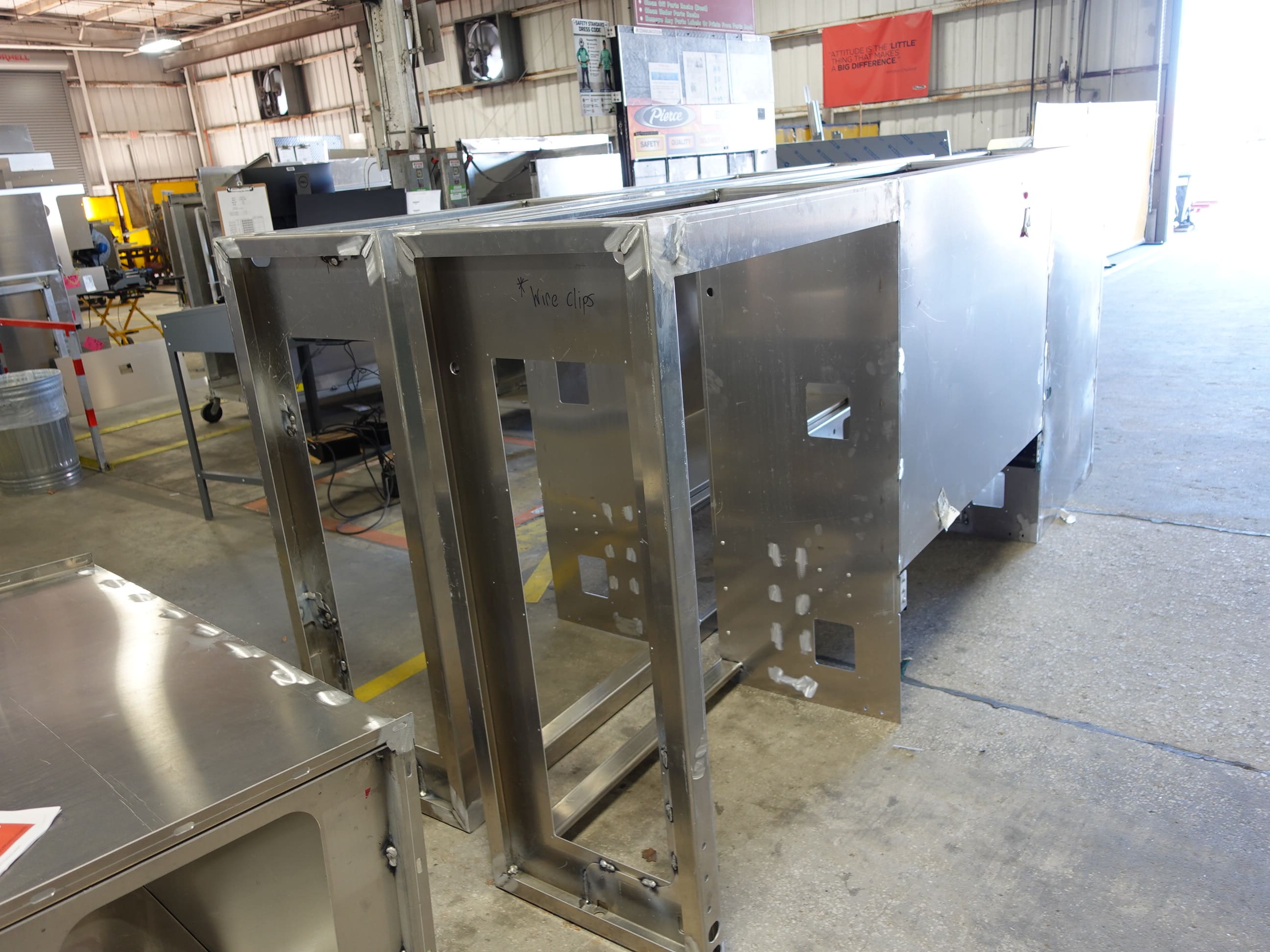

In this report, the chassis was staged (no photos), the pump house began initial assembly, and the body continued fabrication.
03-13-26

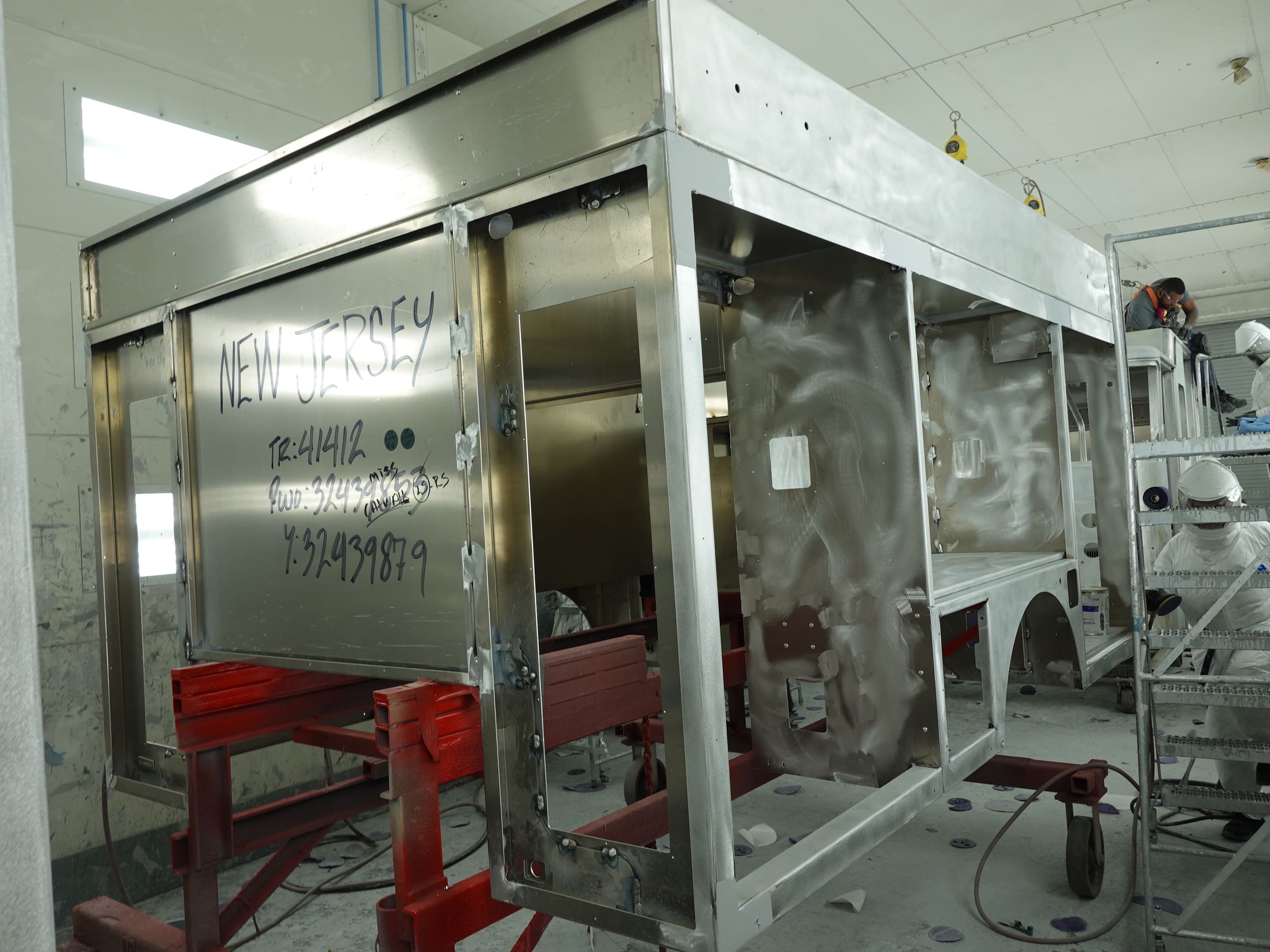

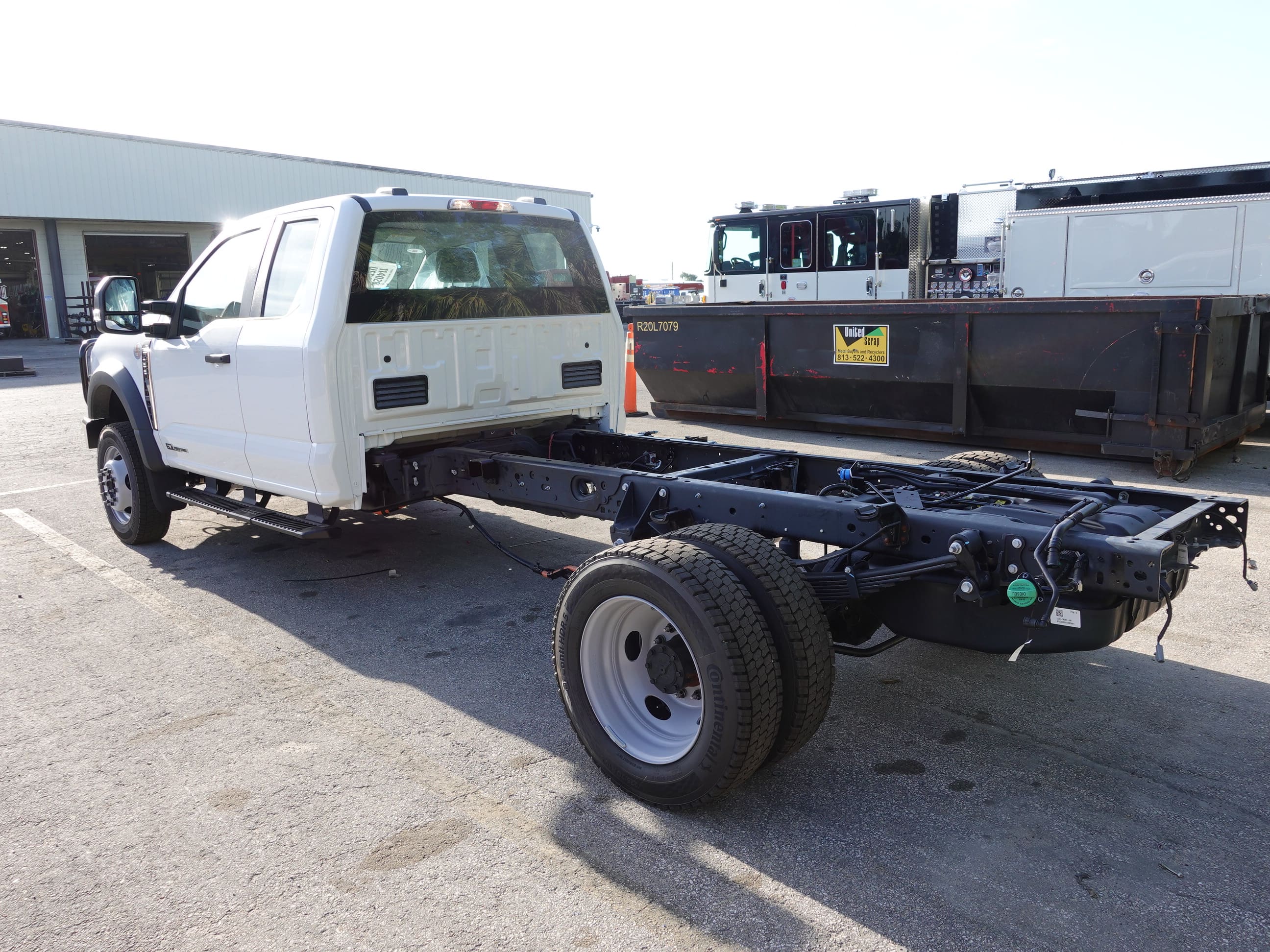

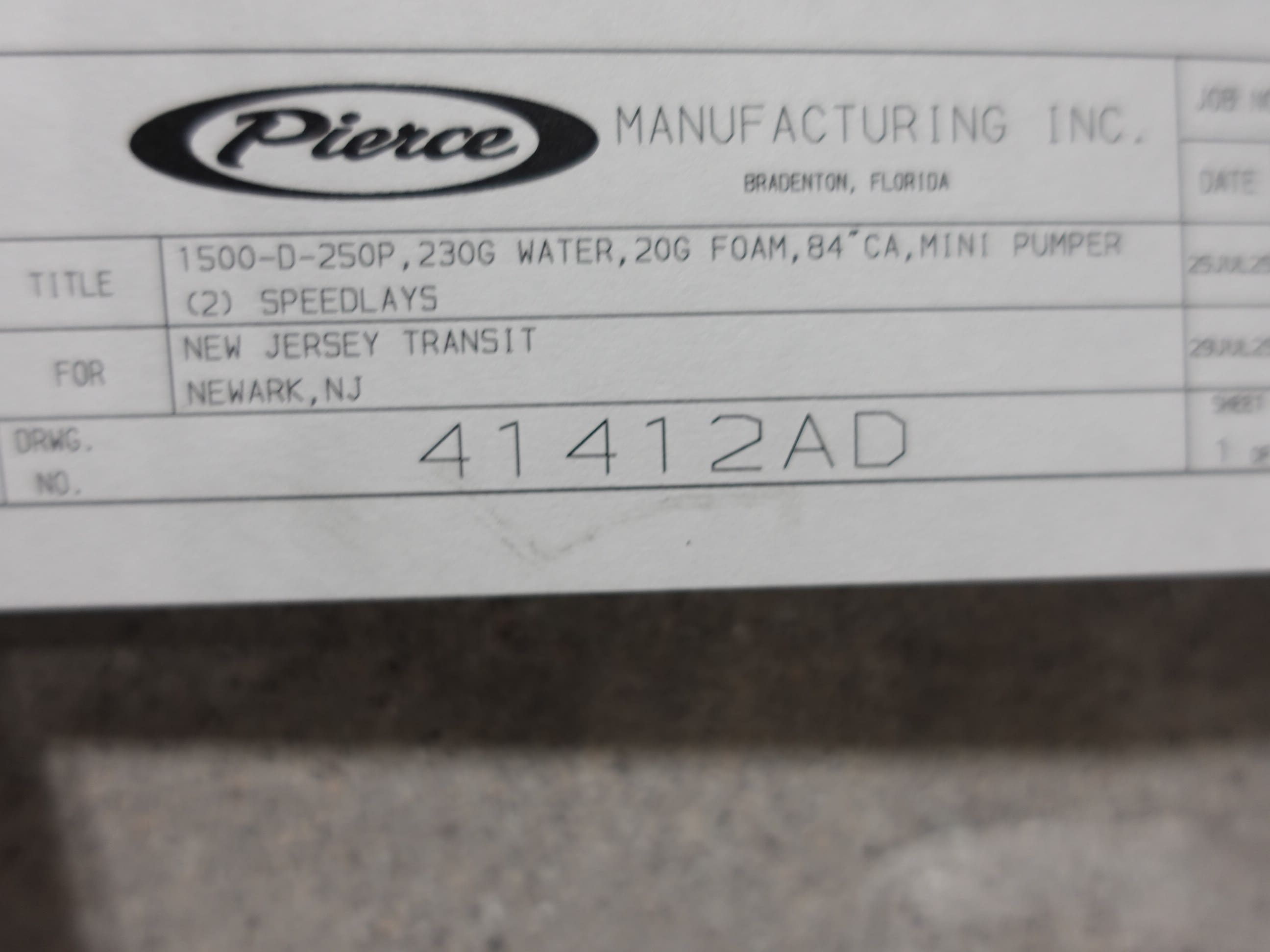

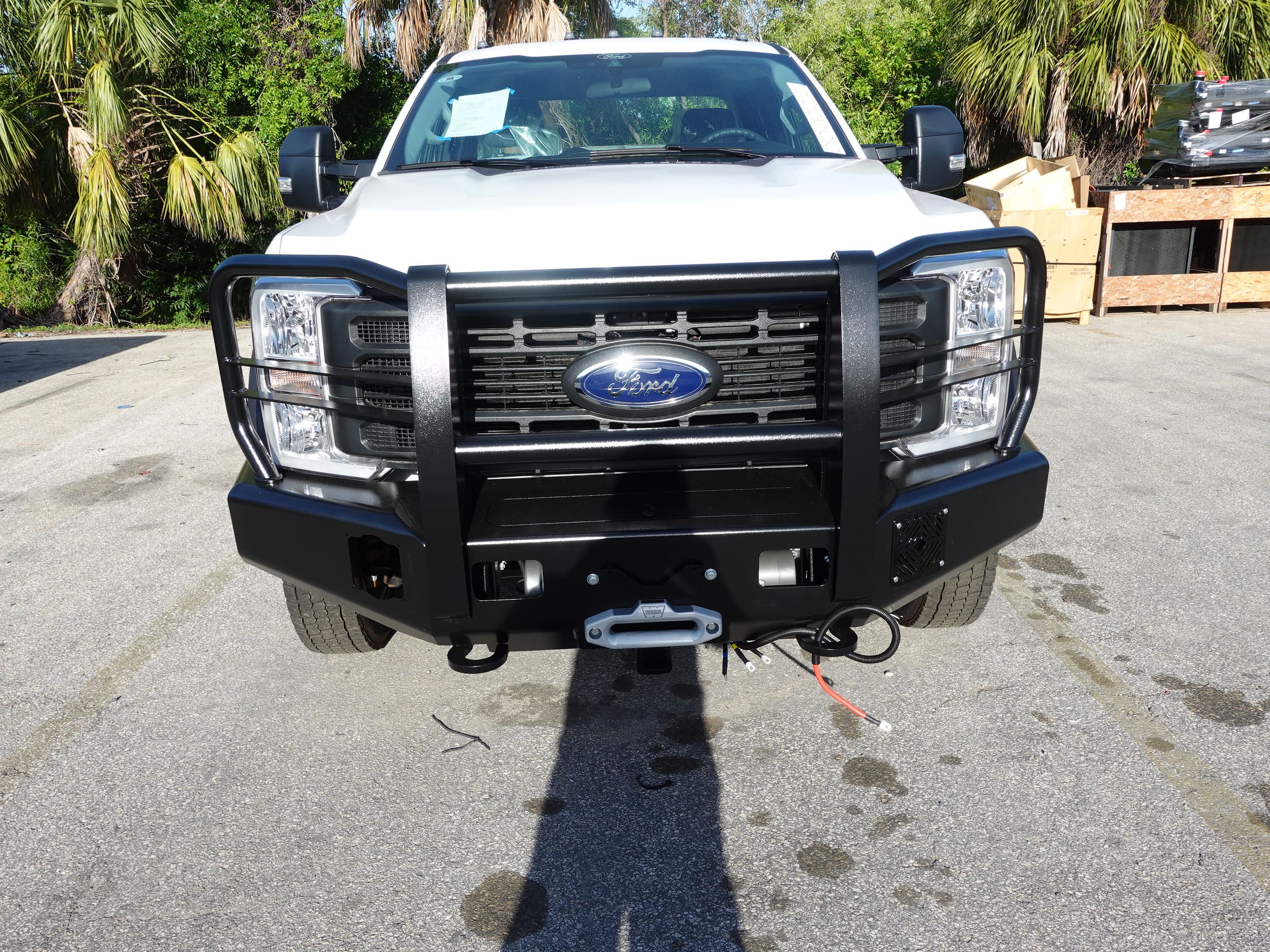

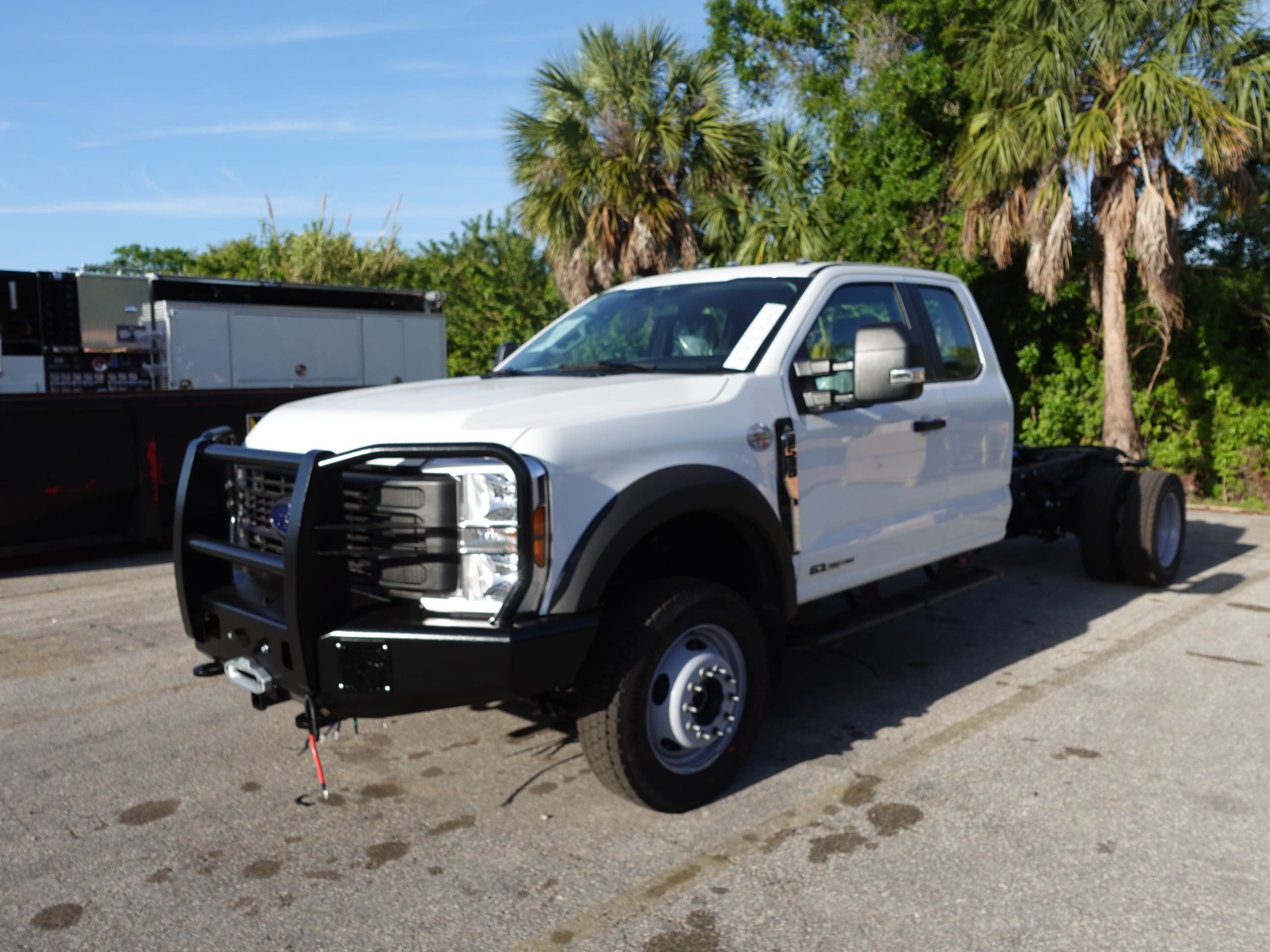

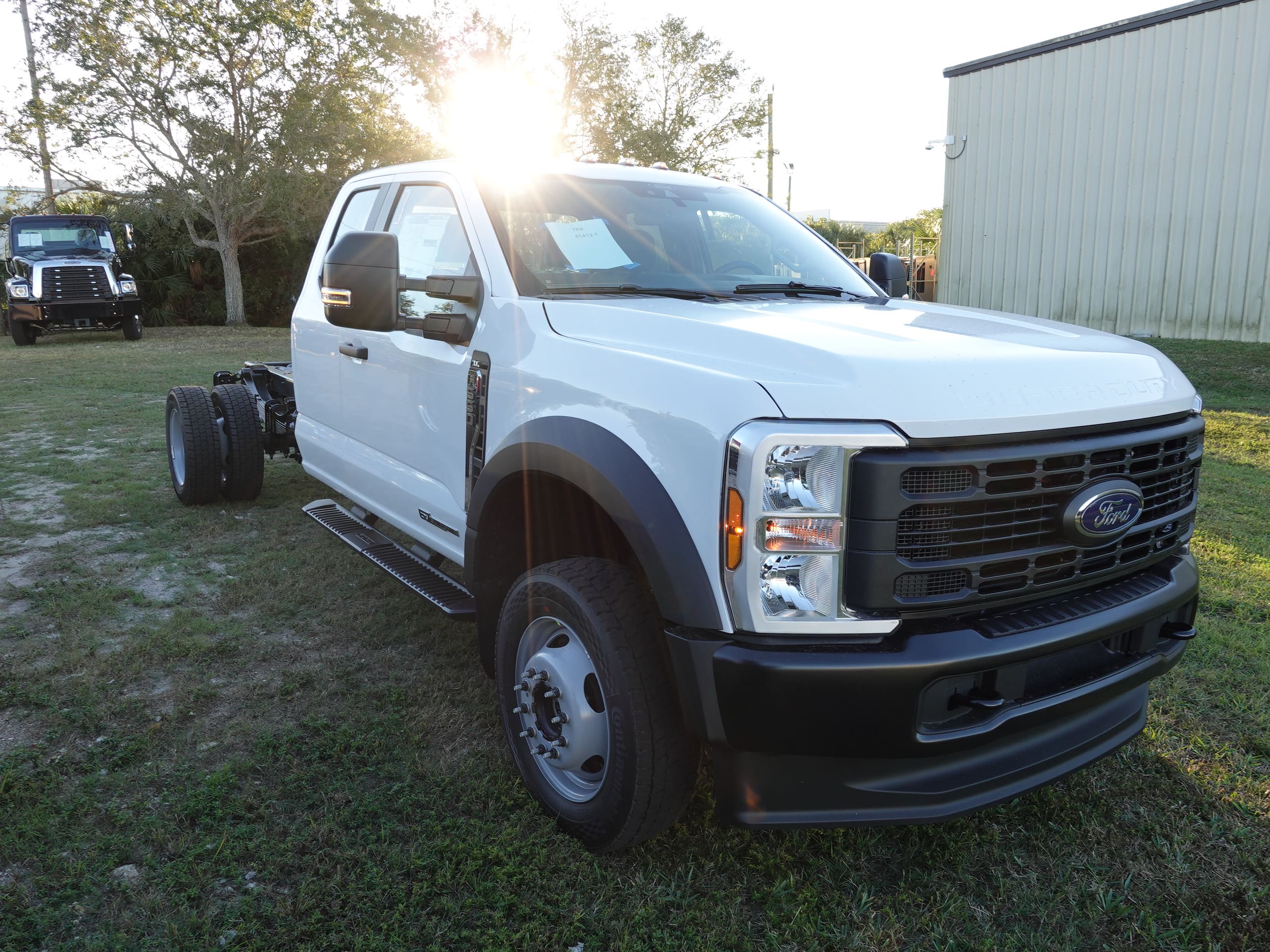

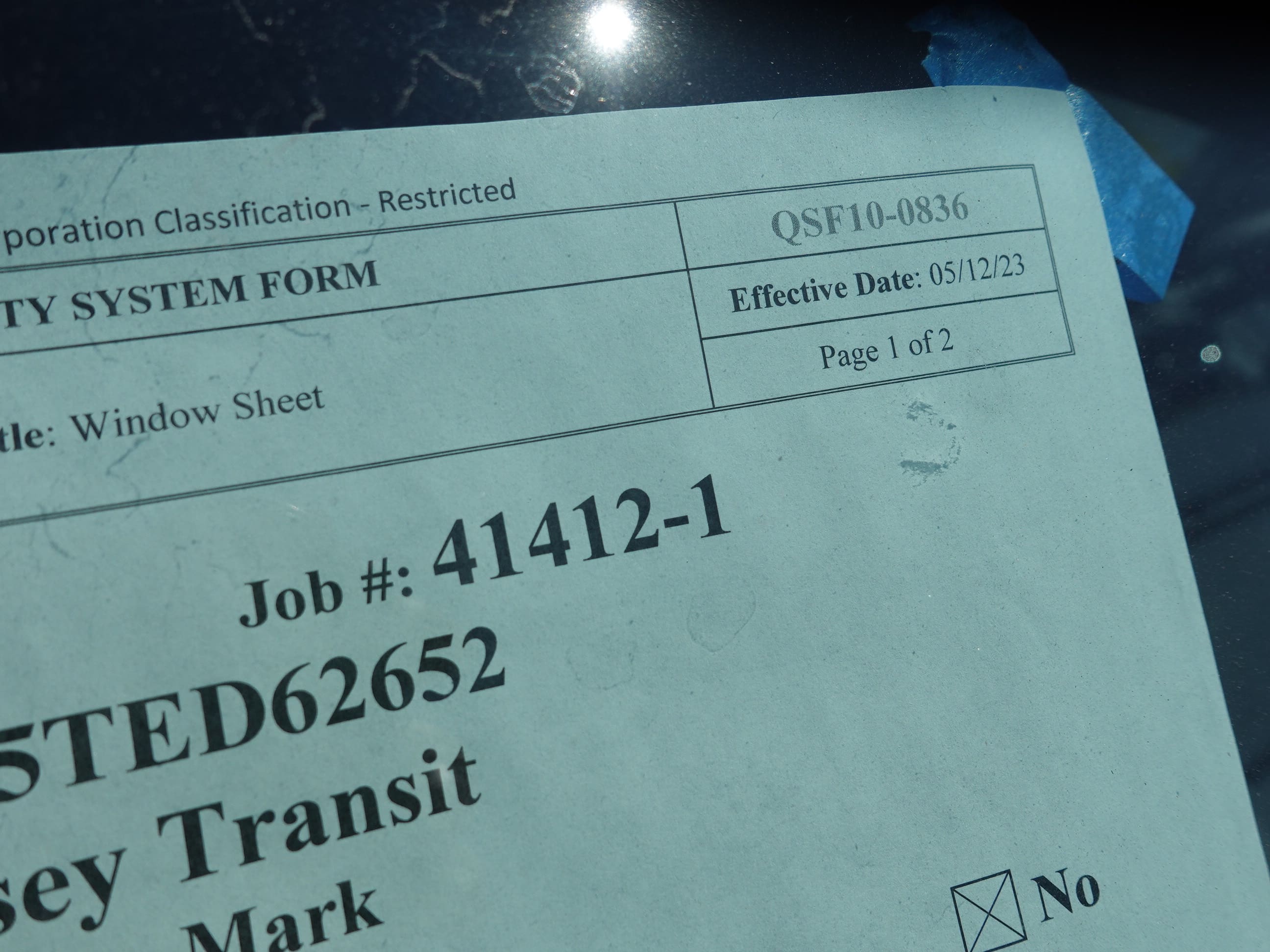

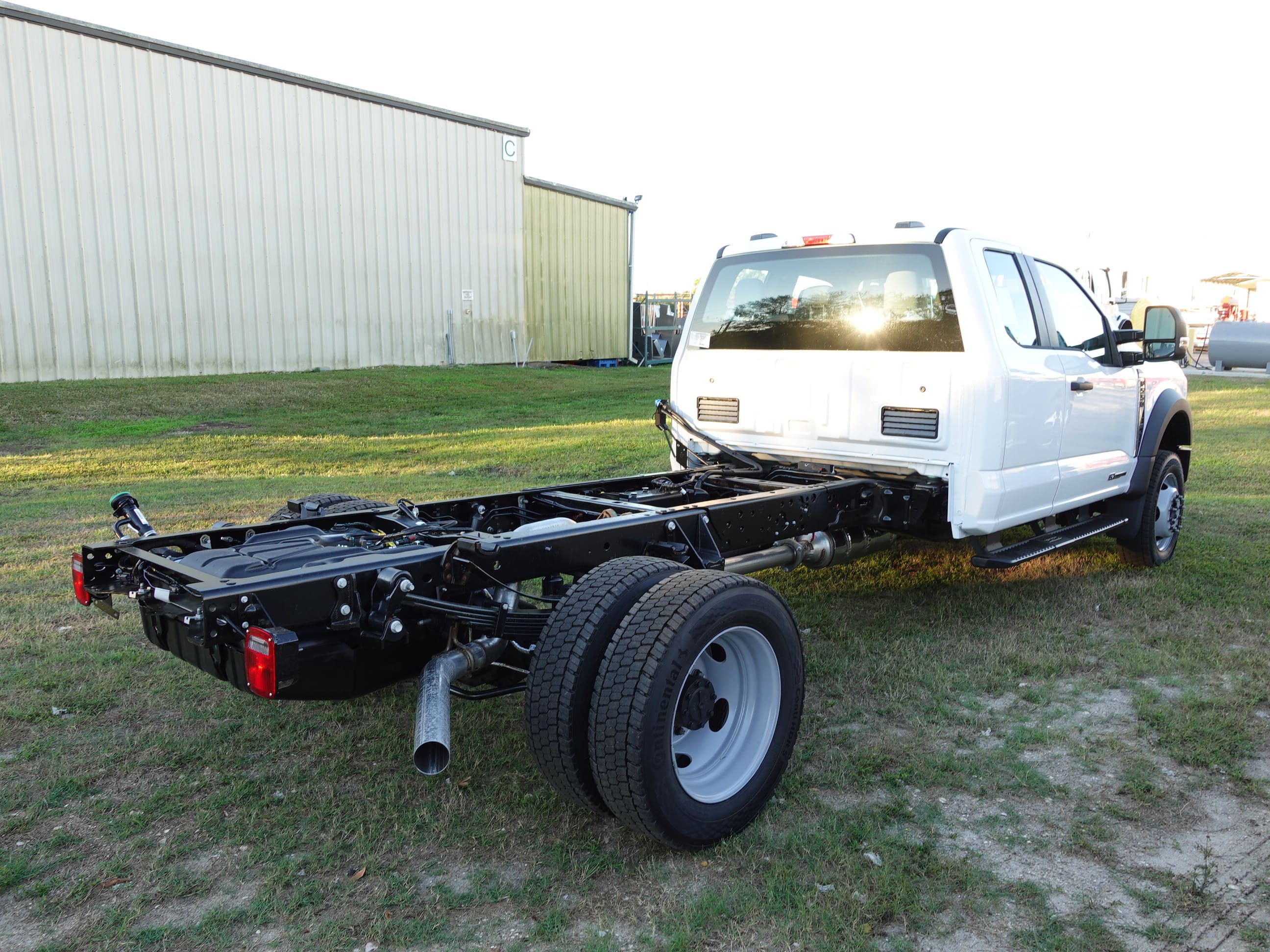

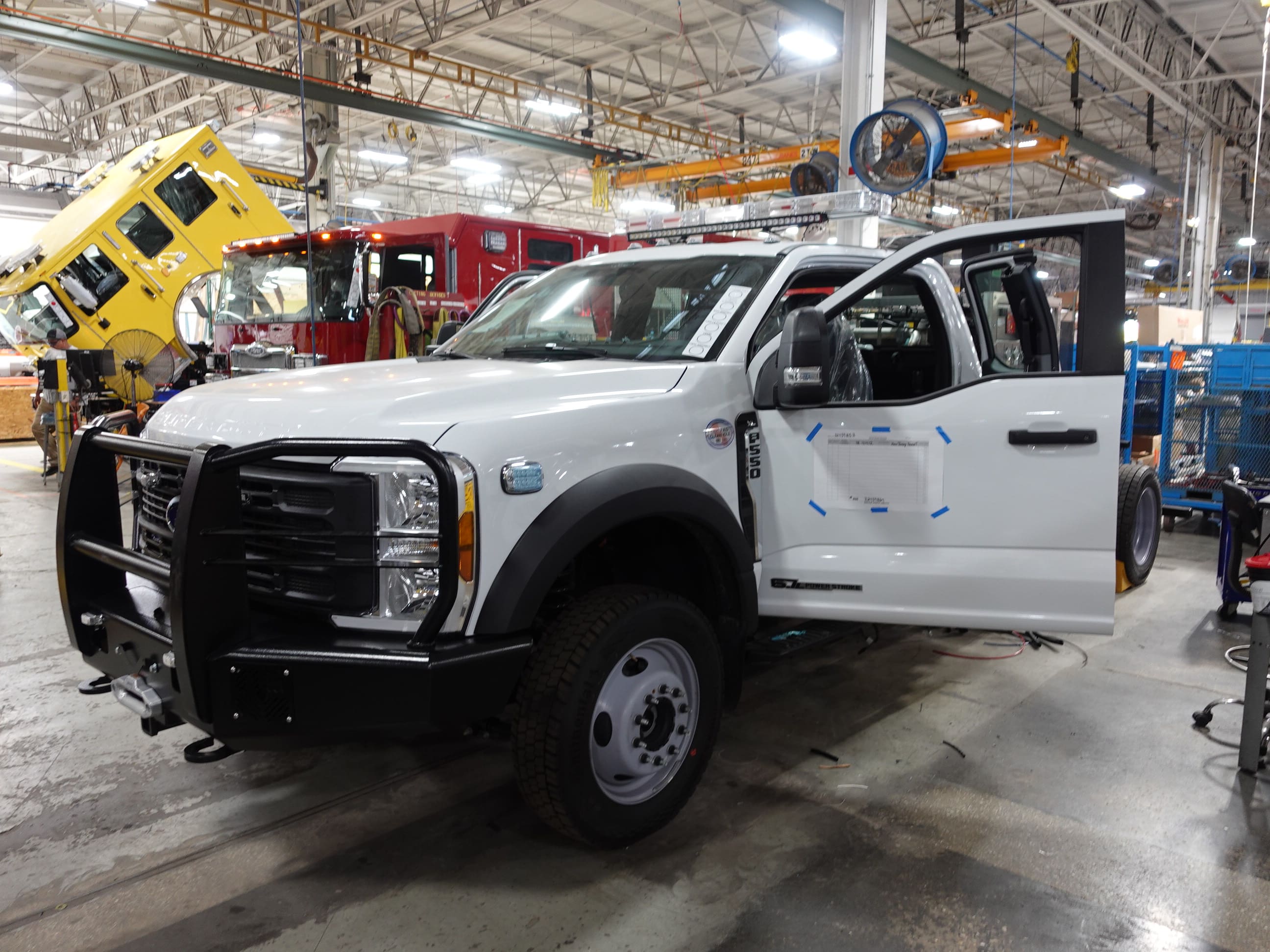

This new Pierce apparatus is now in production! In this report, the commercial chassis arrived and was staged while the body panels began fabrication.
