41296 – Mountain Lakes – Saber Pumper

Saber Pumper

Job #: 41296

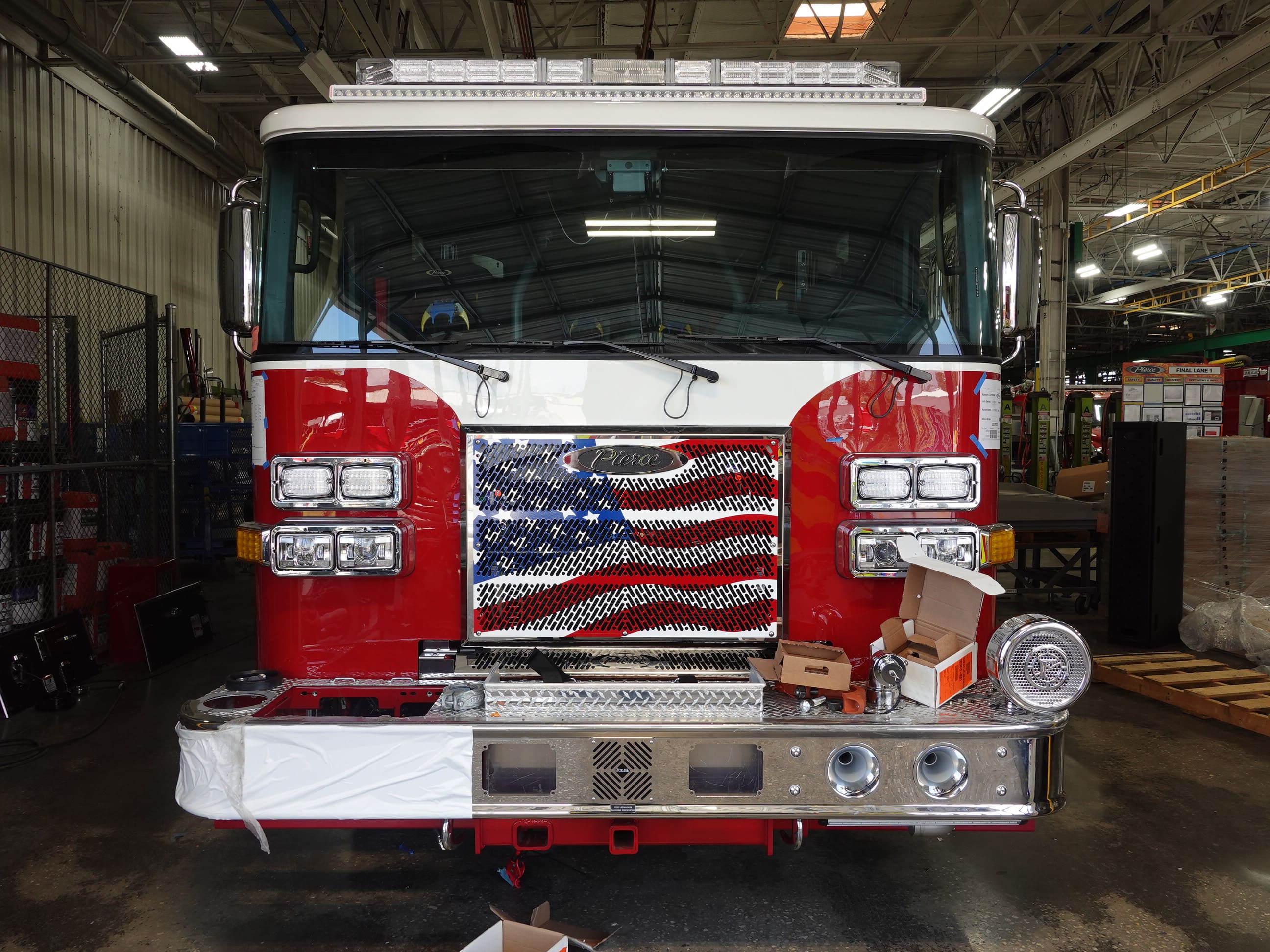

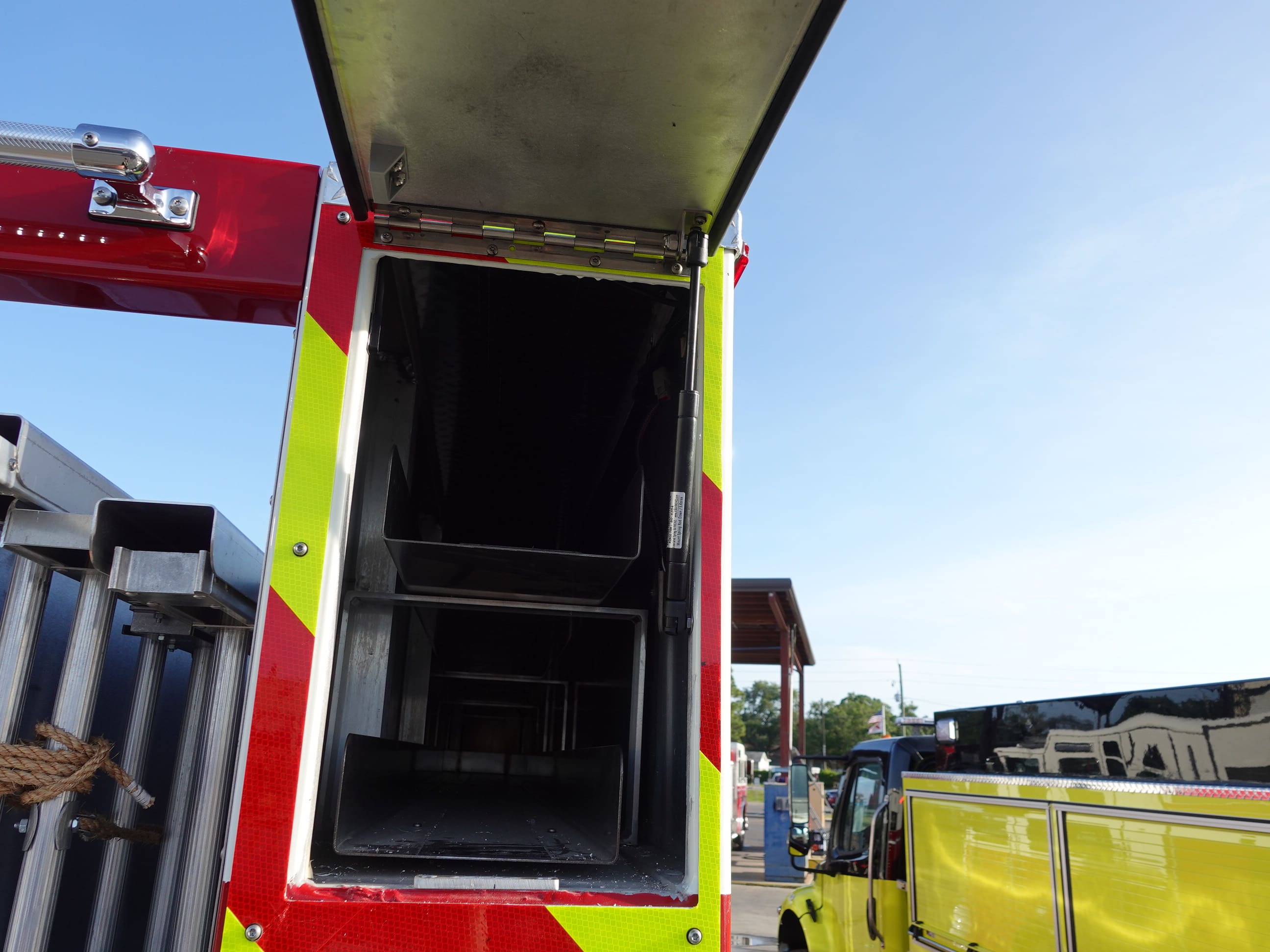

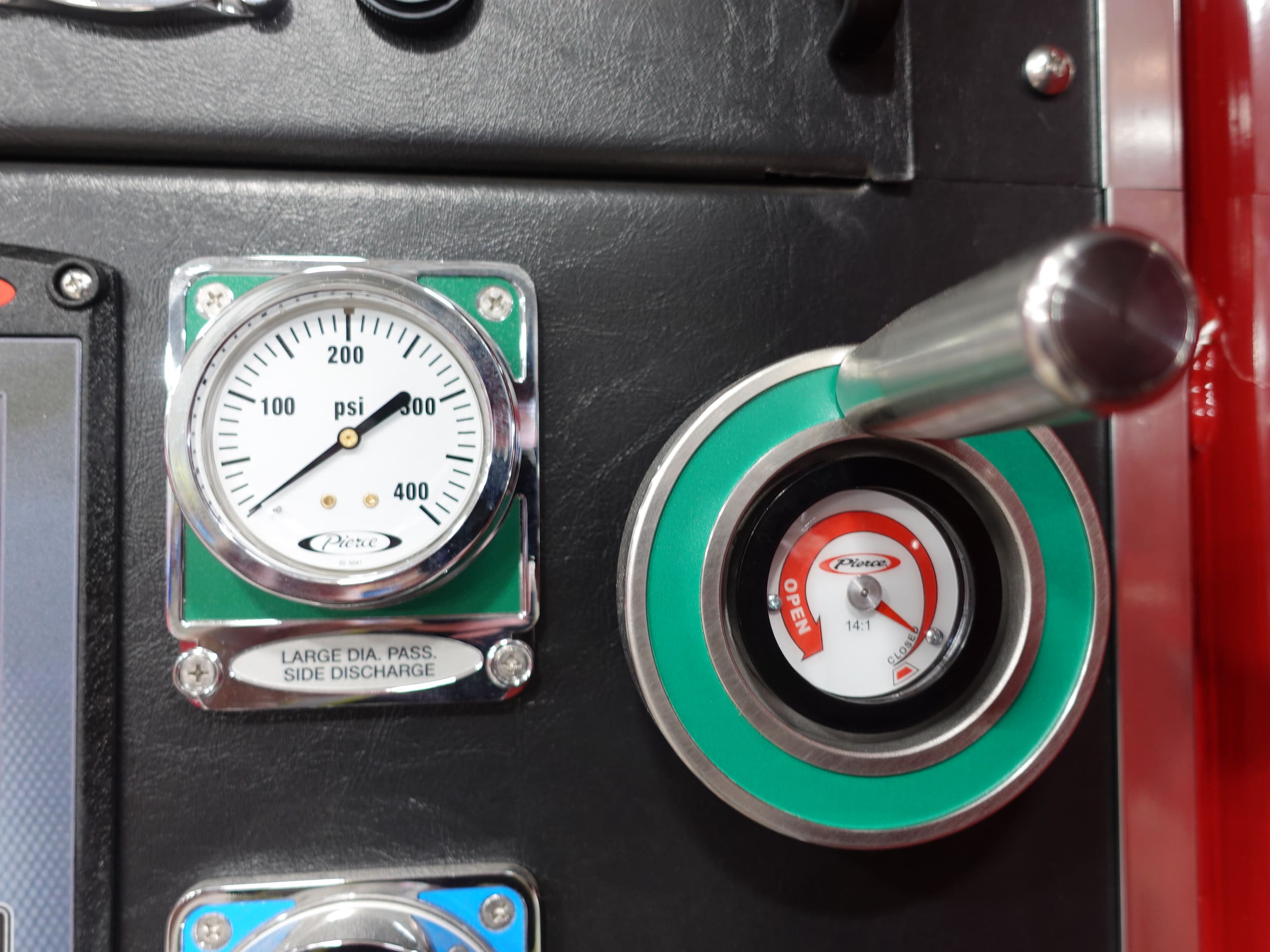

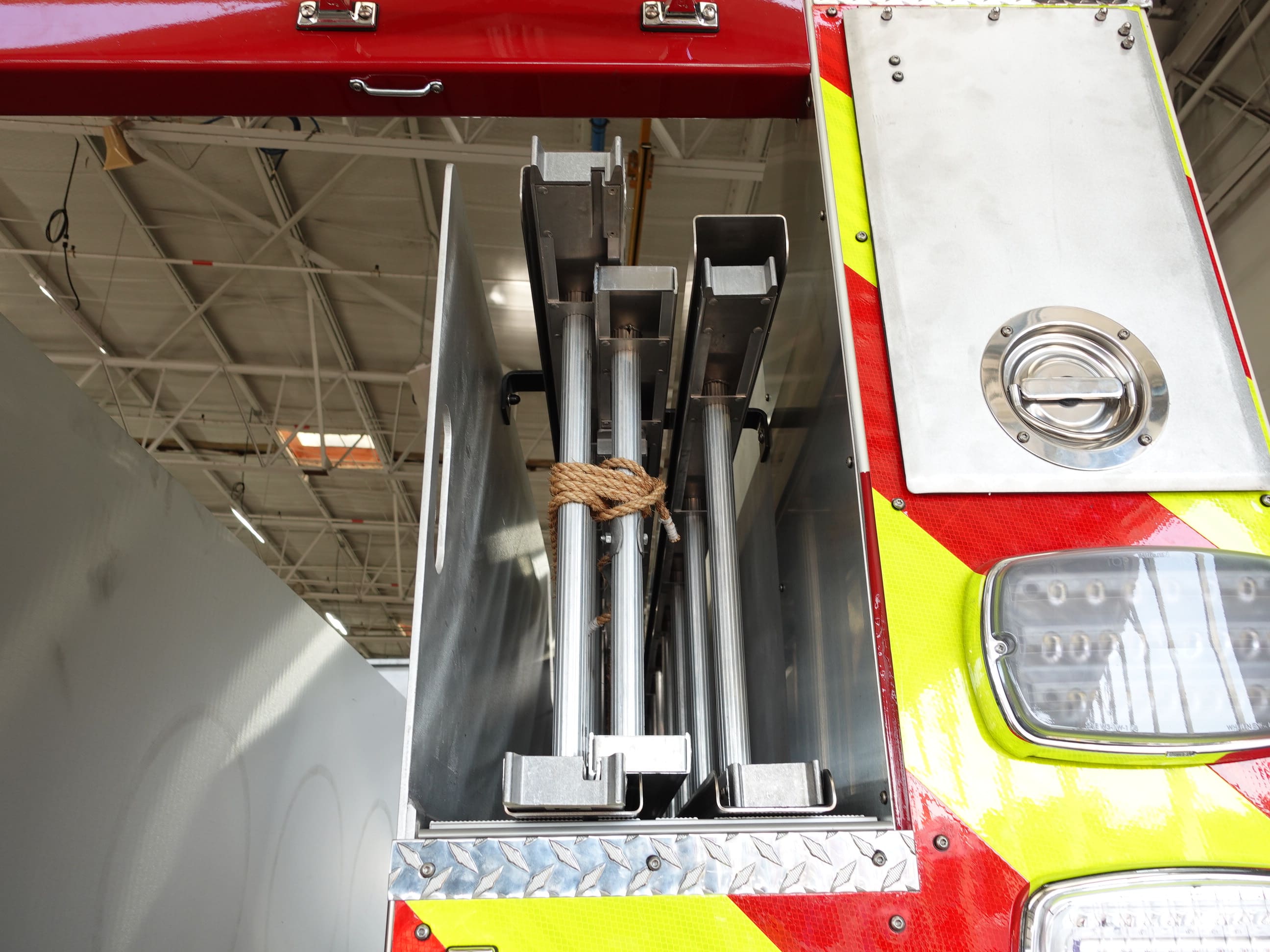

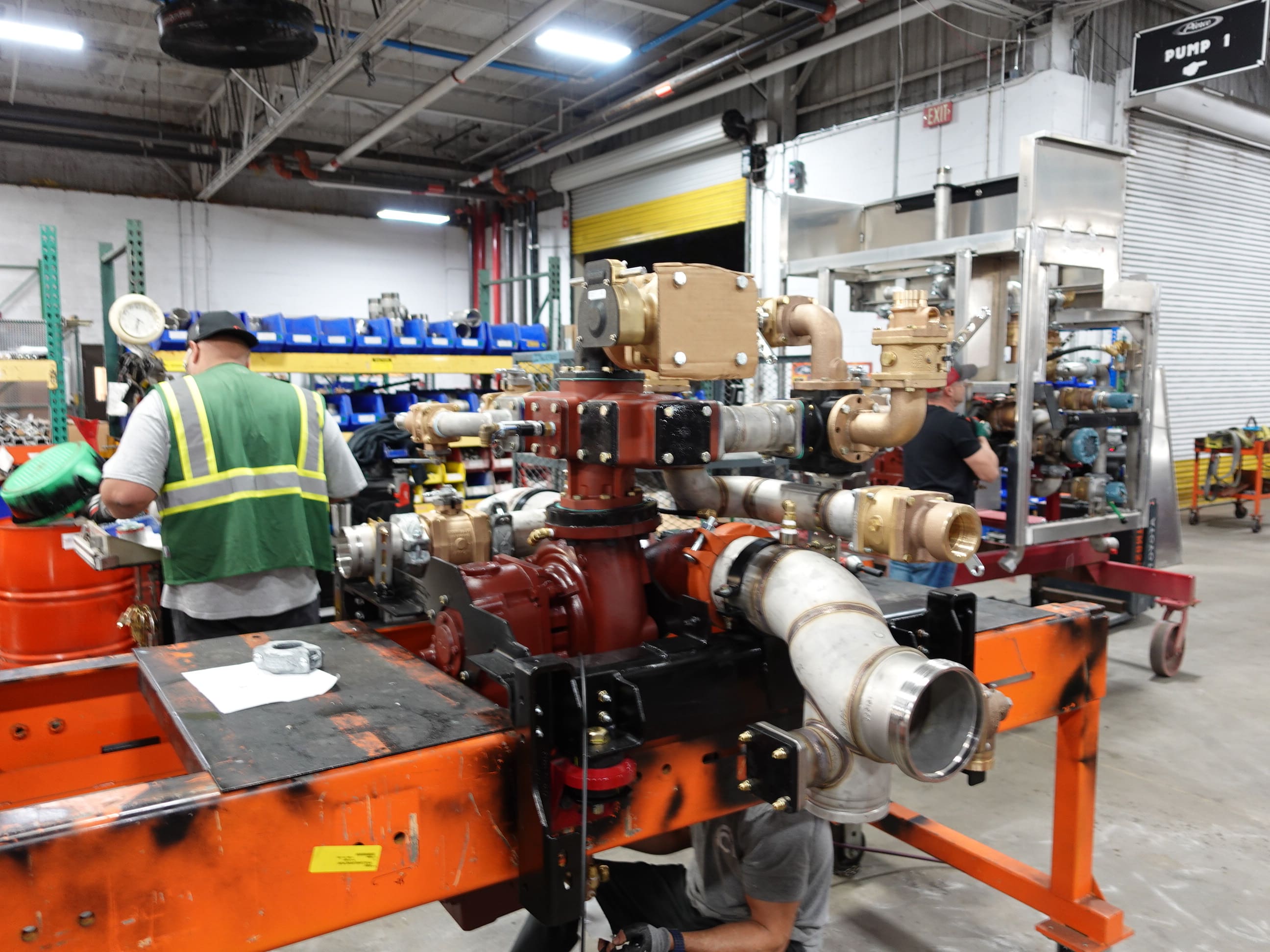

PROGRESS UPDATES

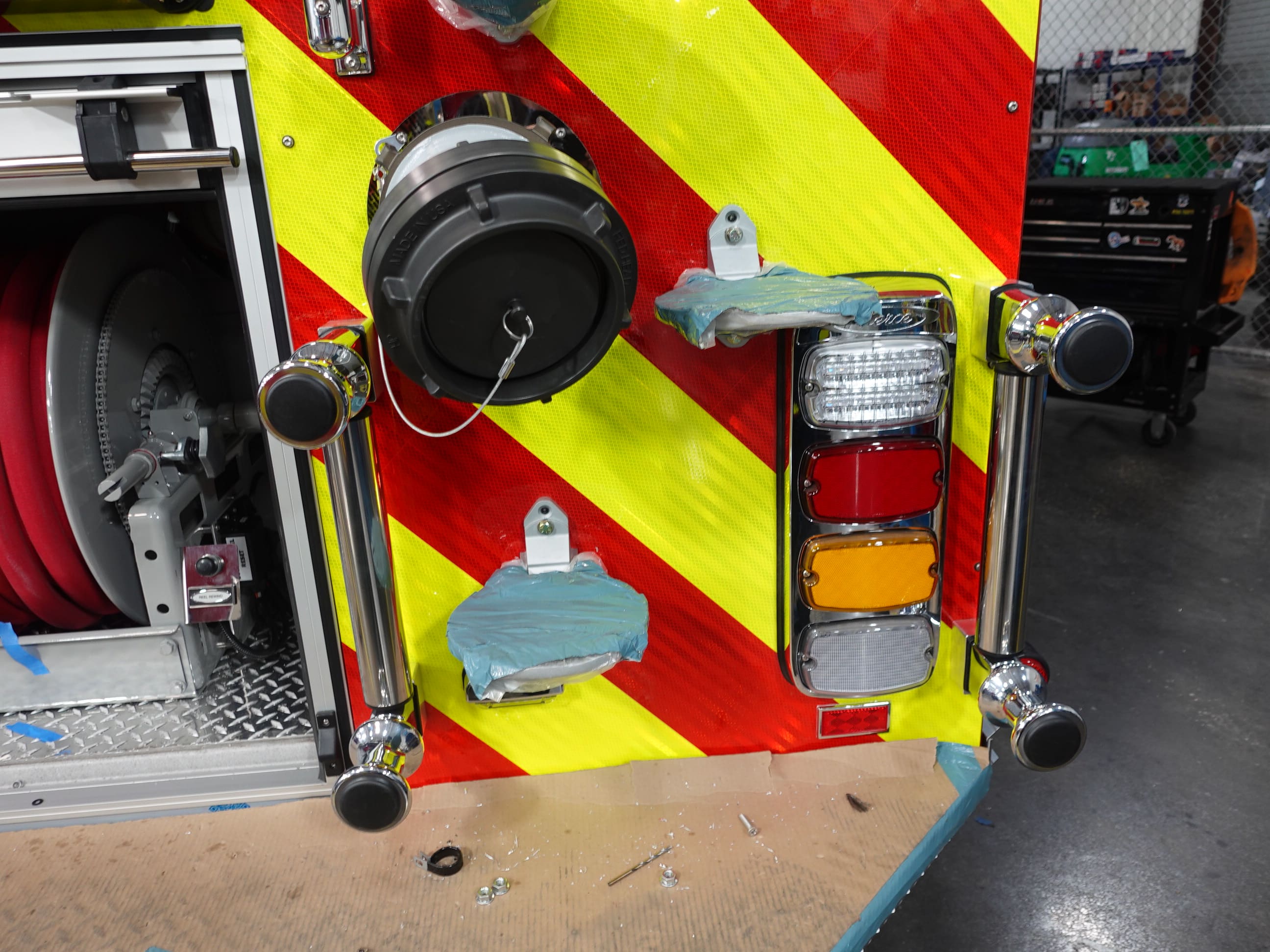

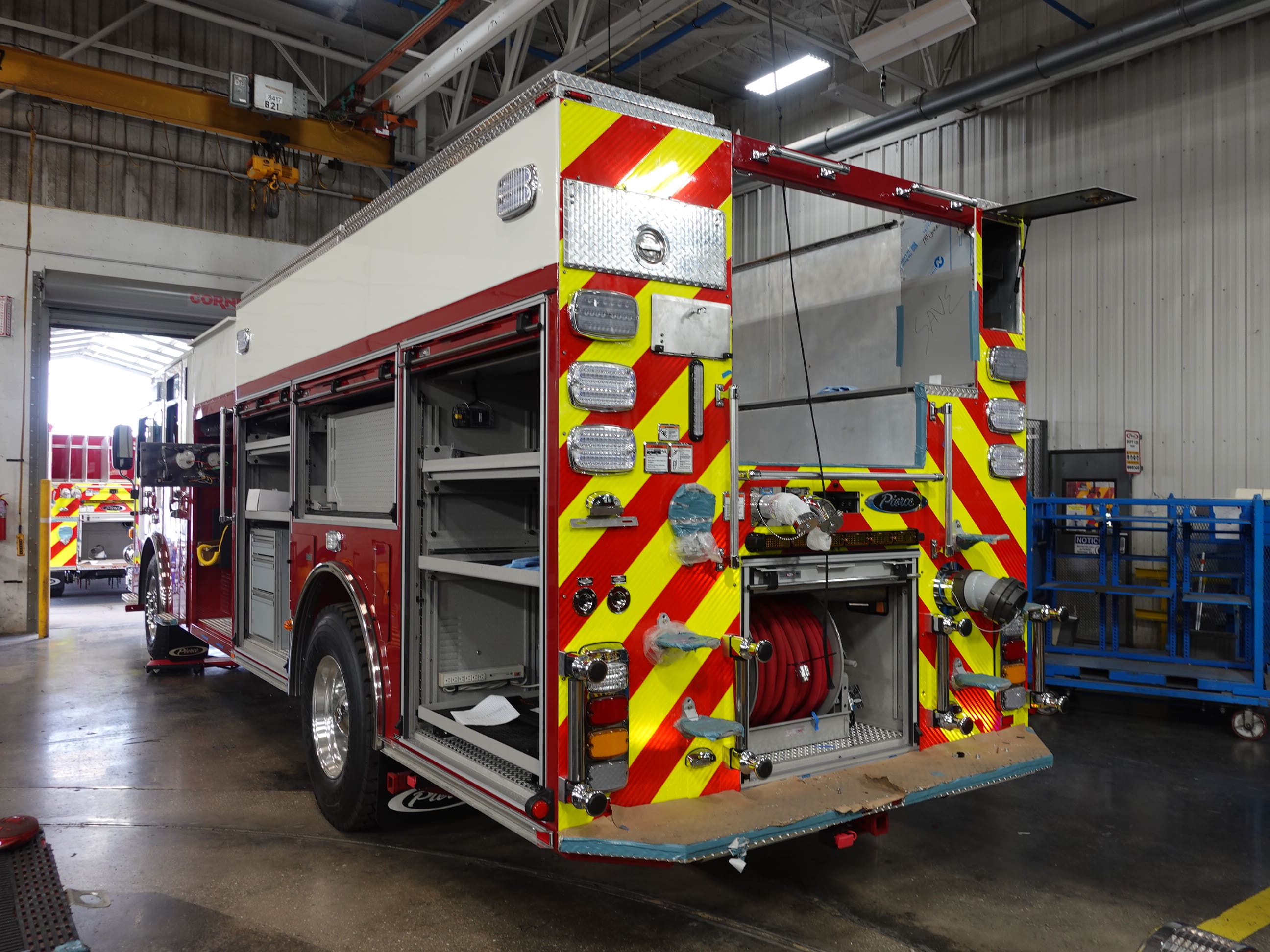

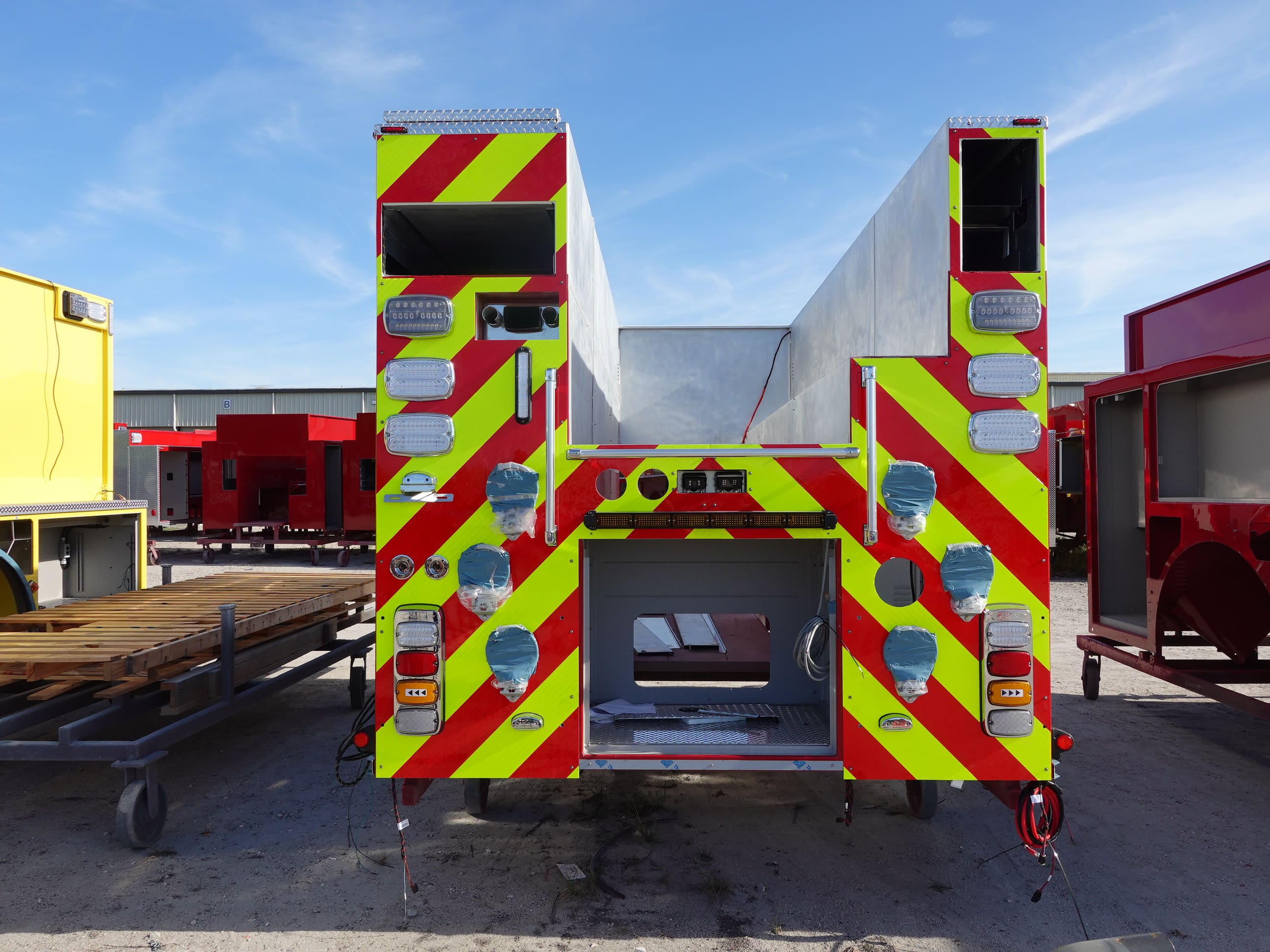

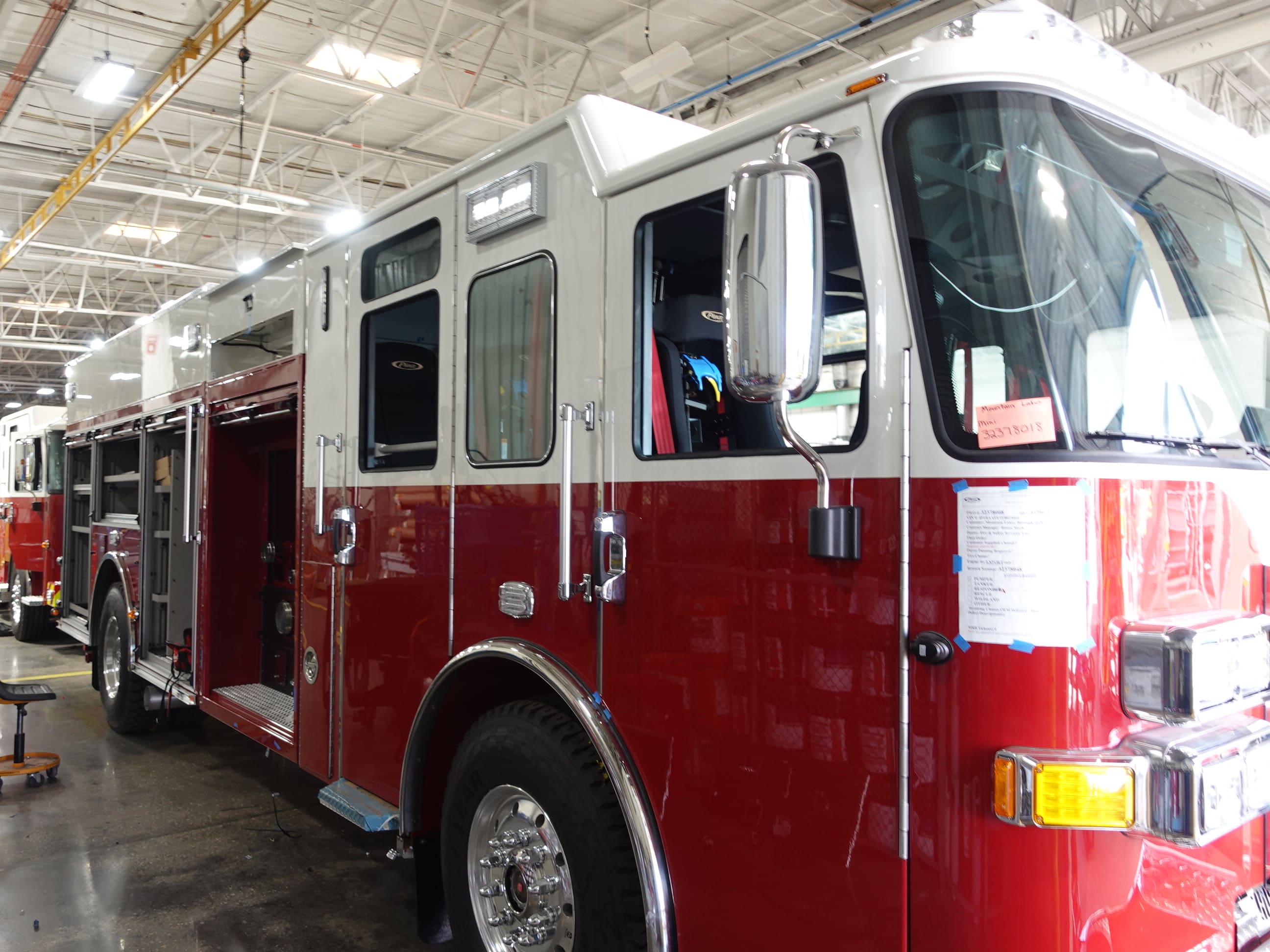

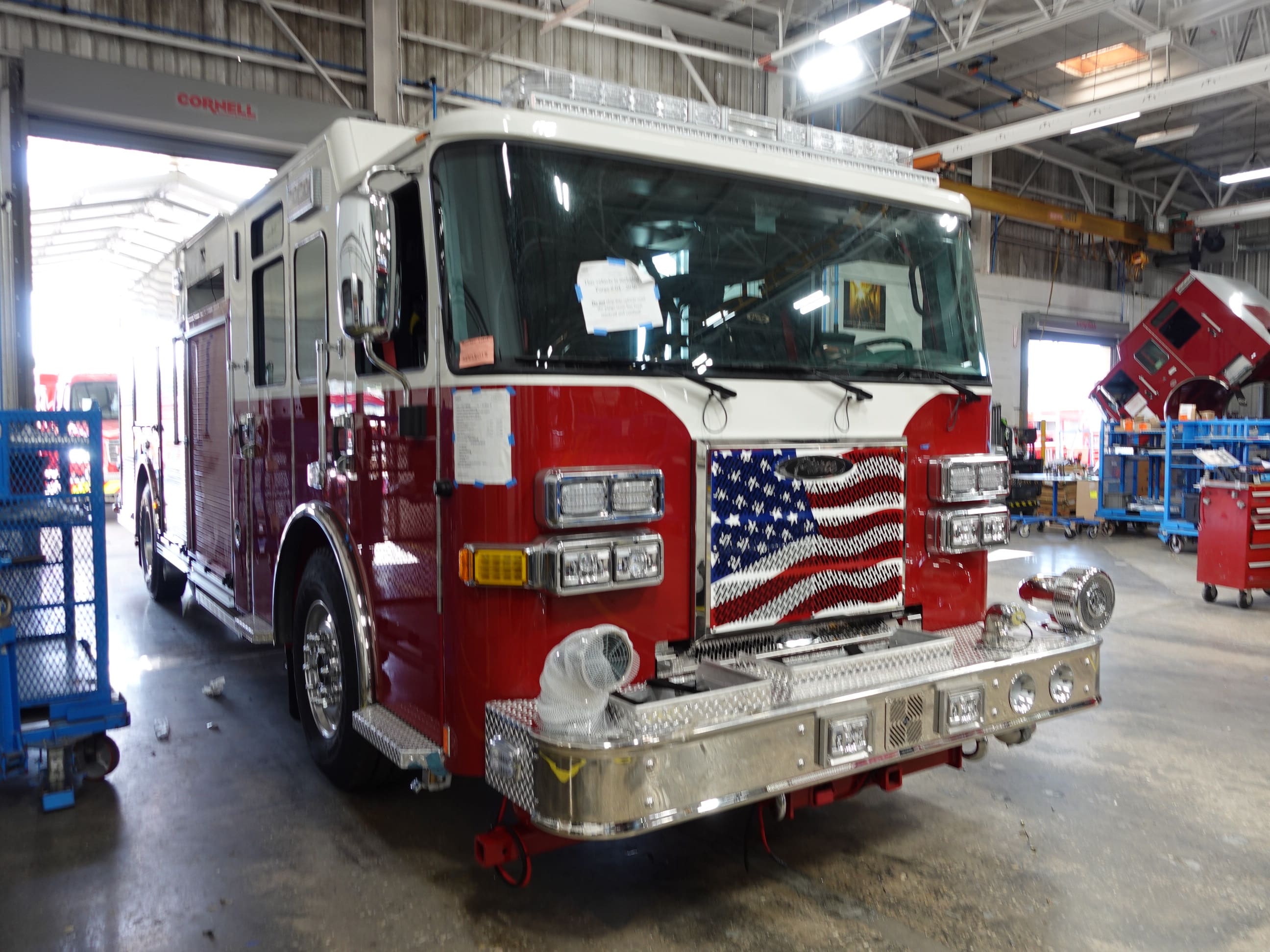

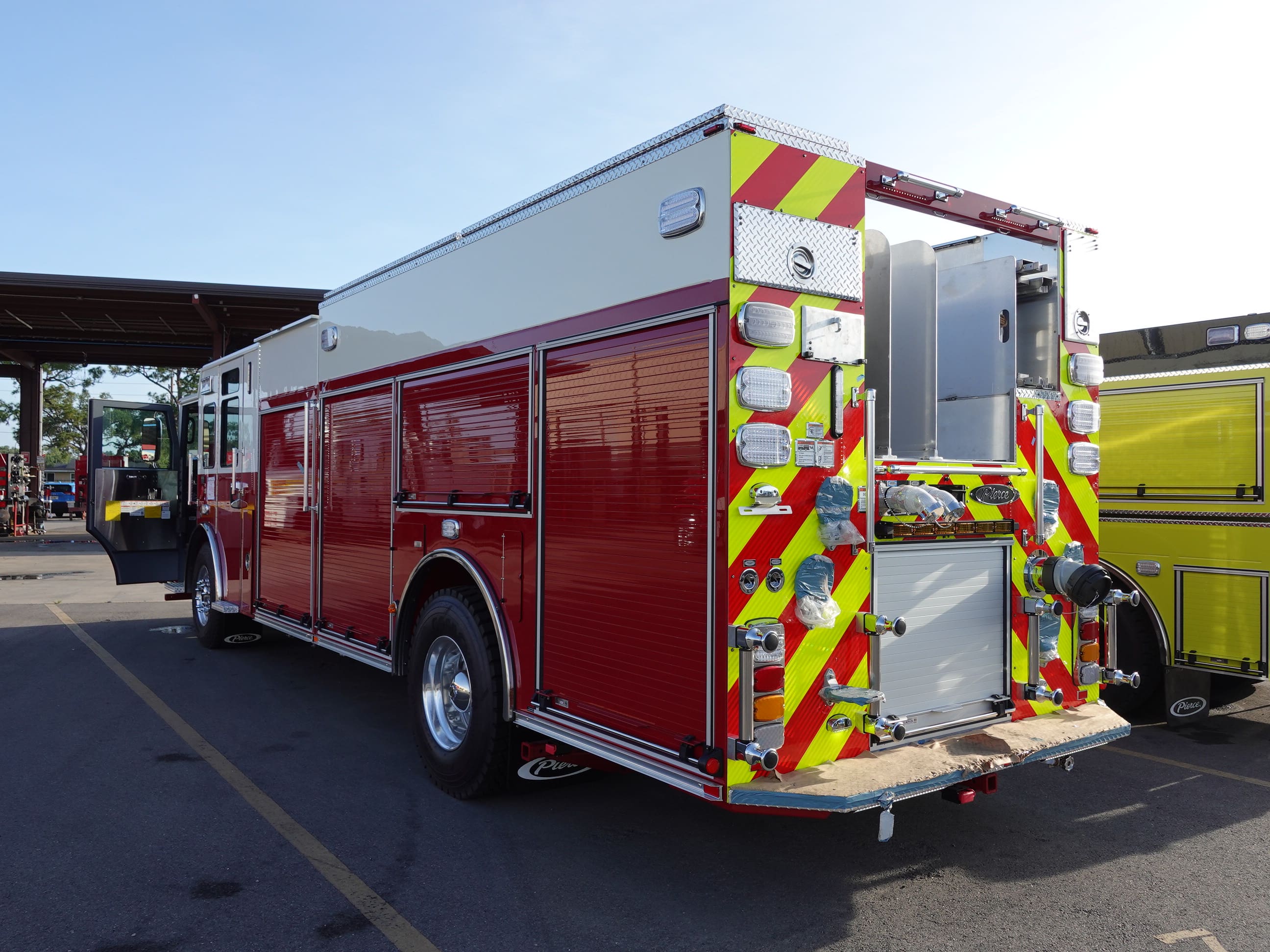

05-29-26

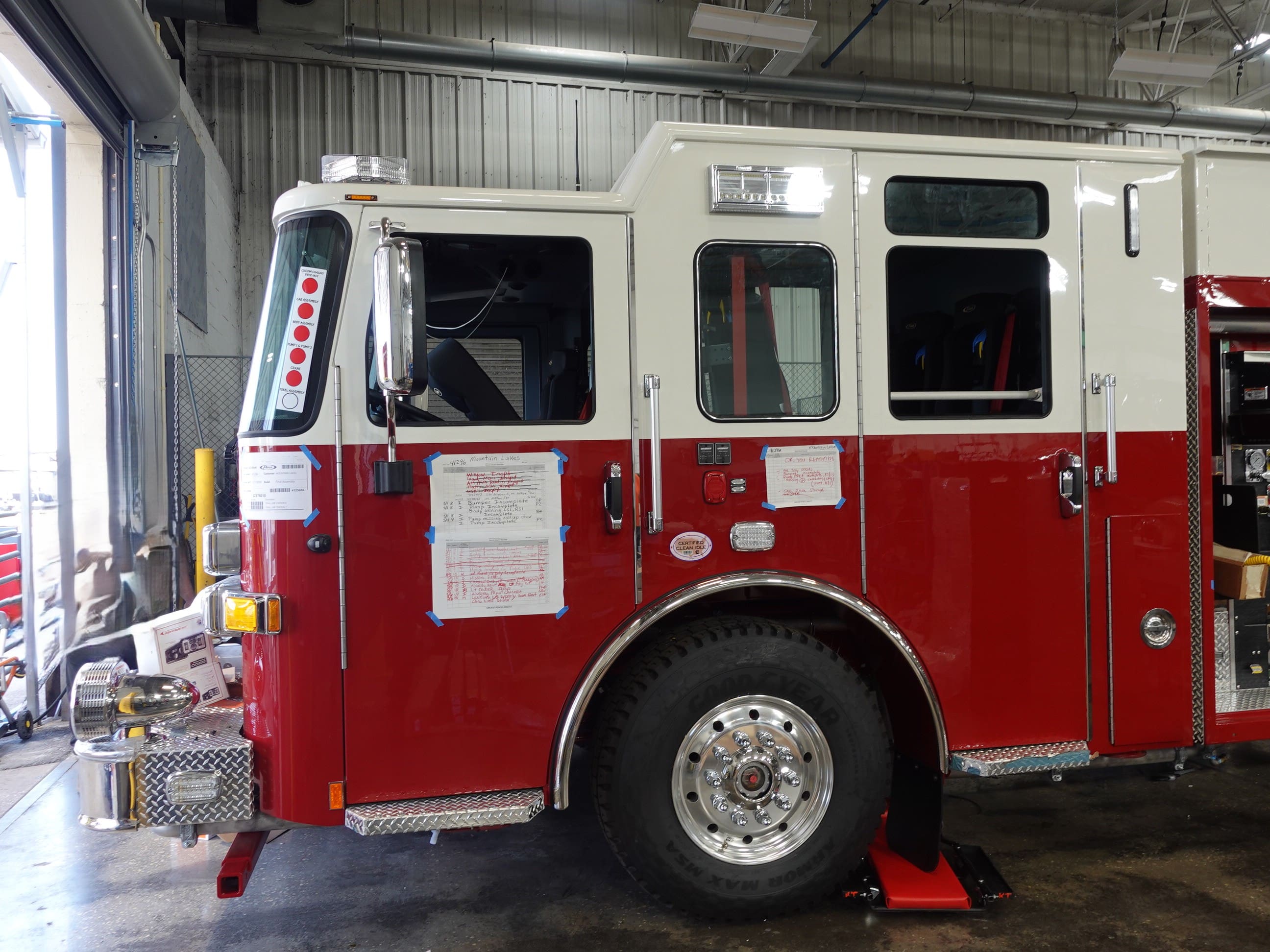

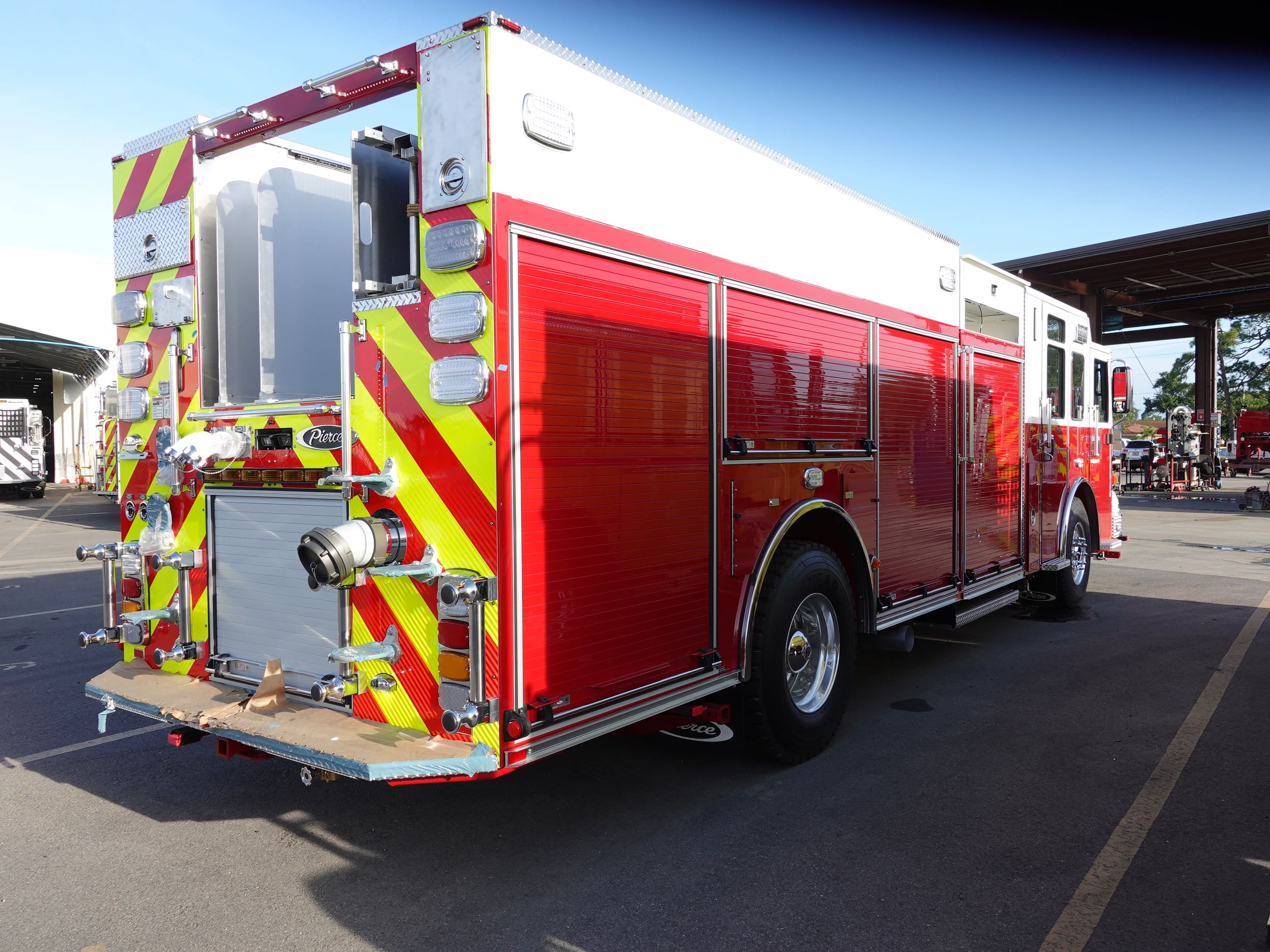

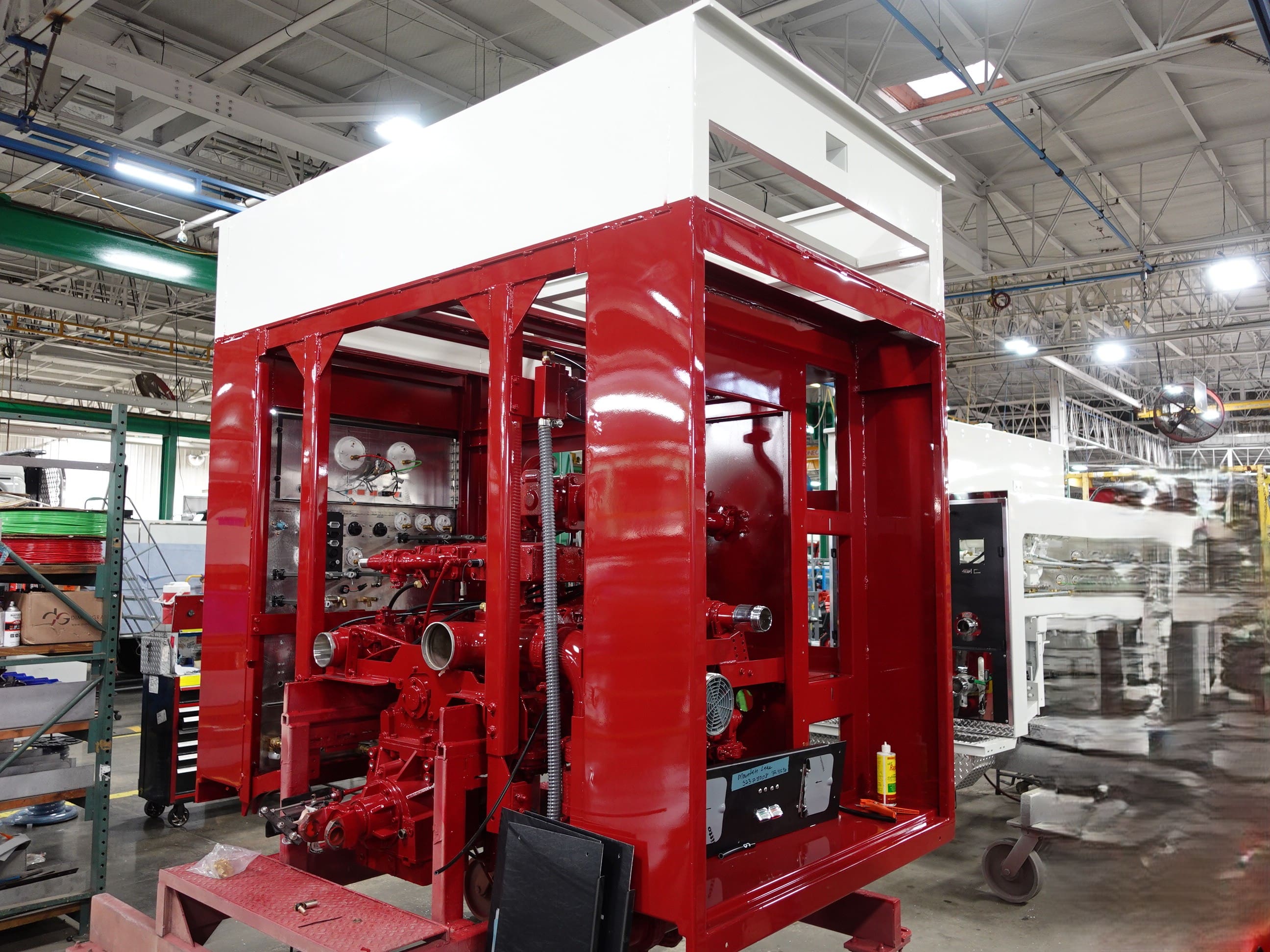

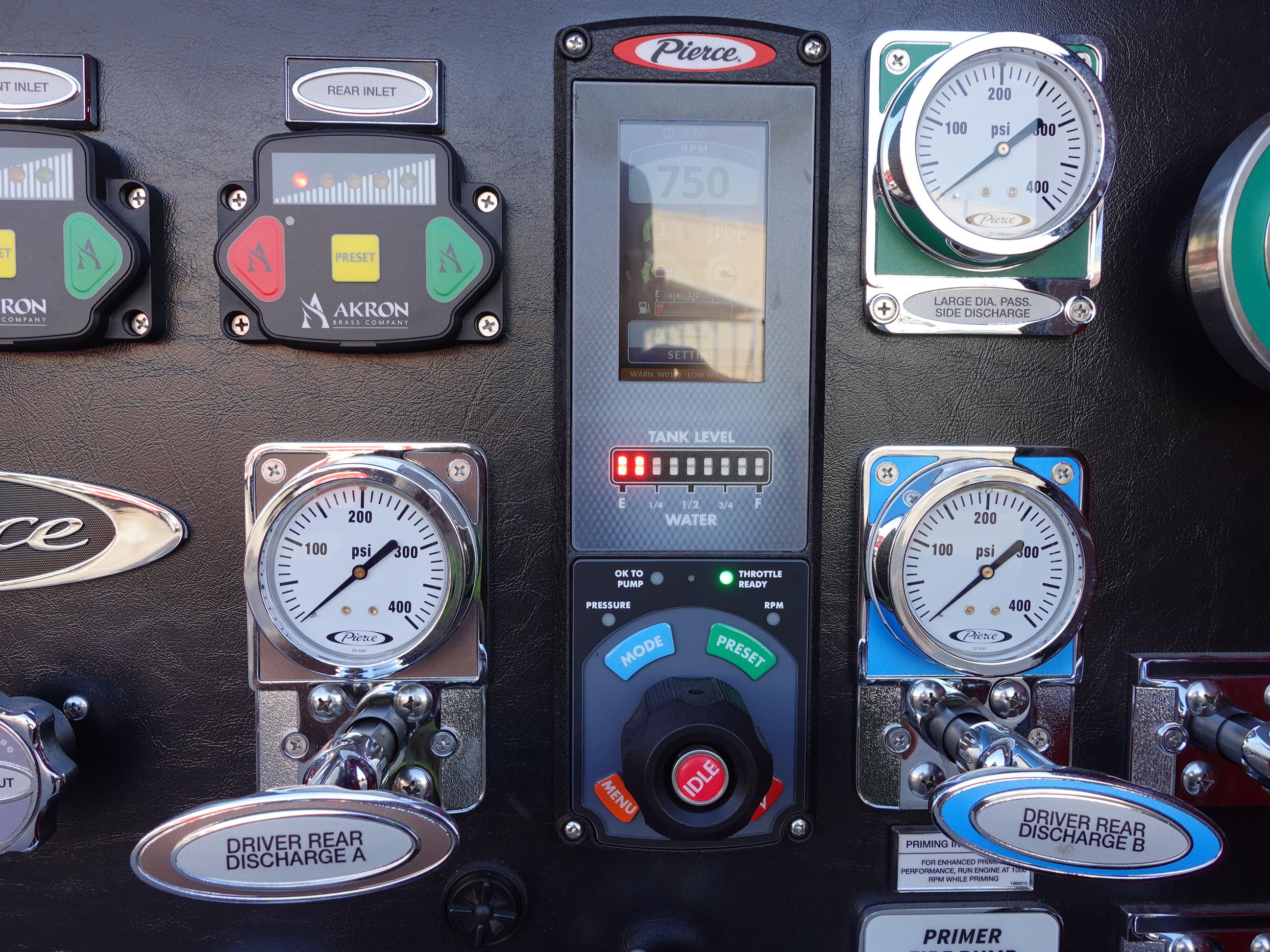

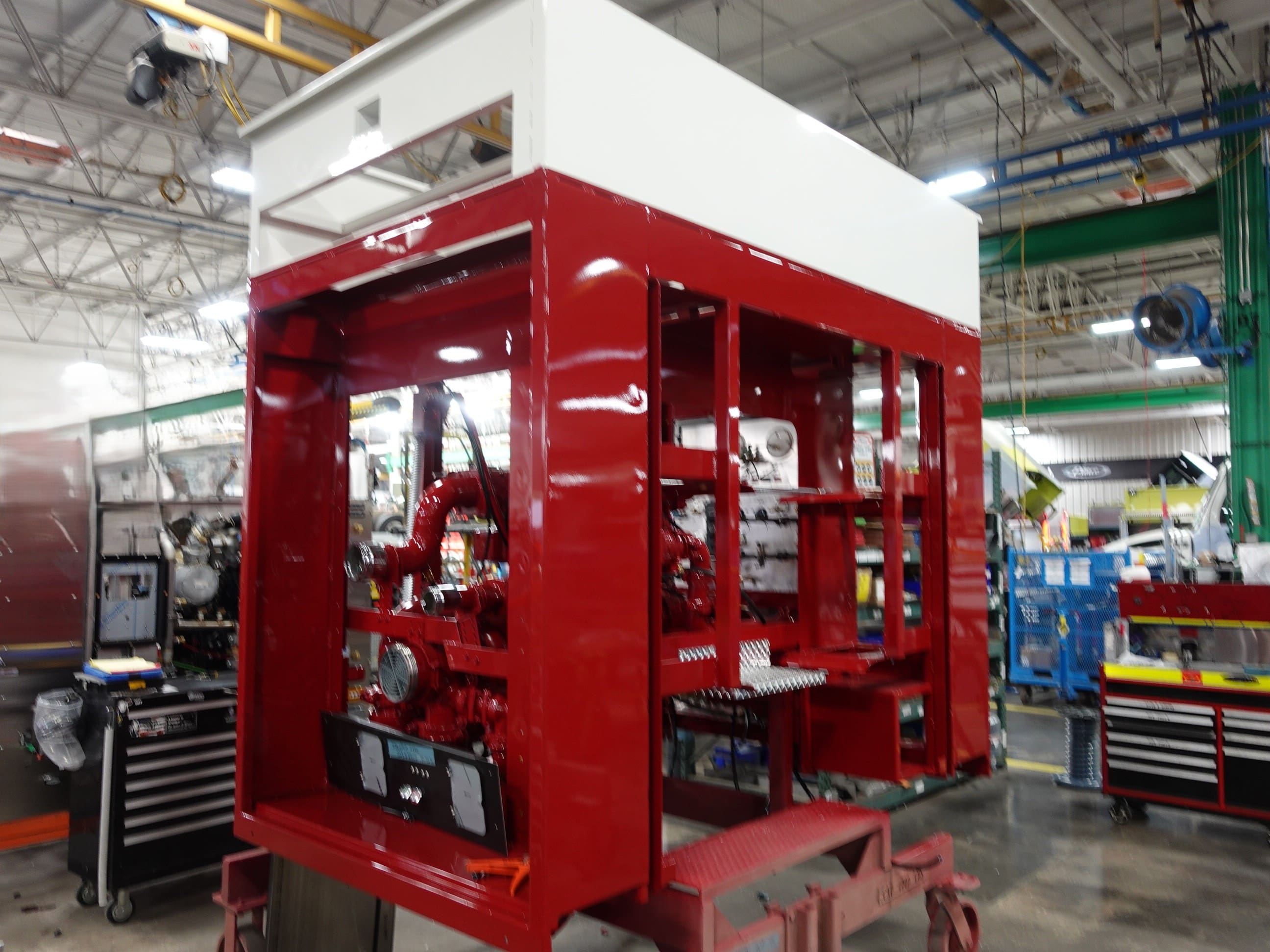

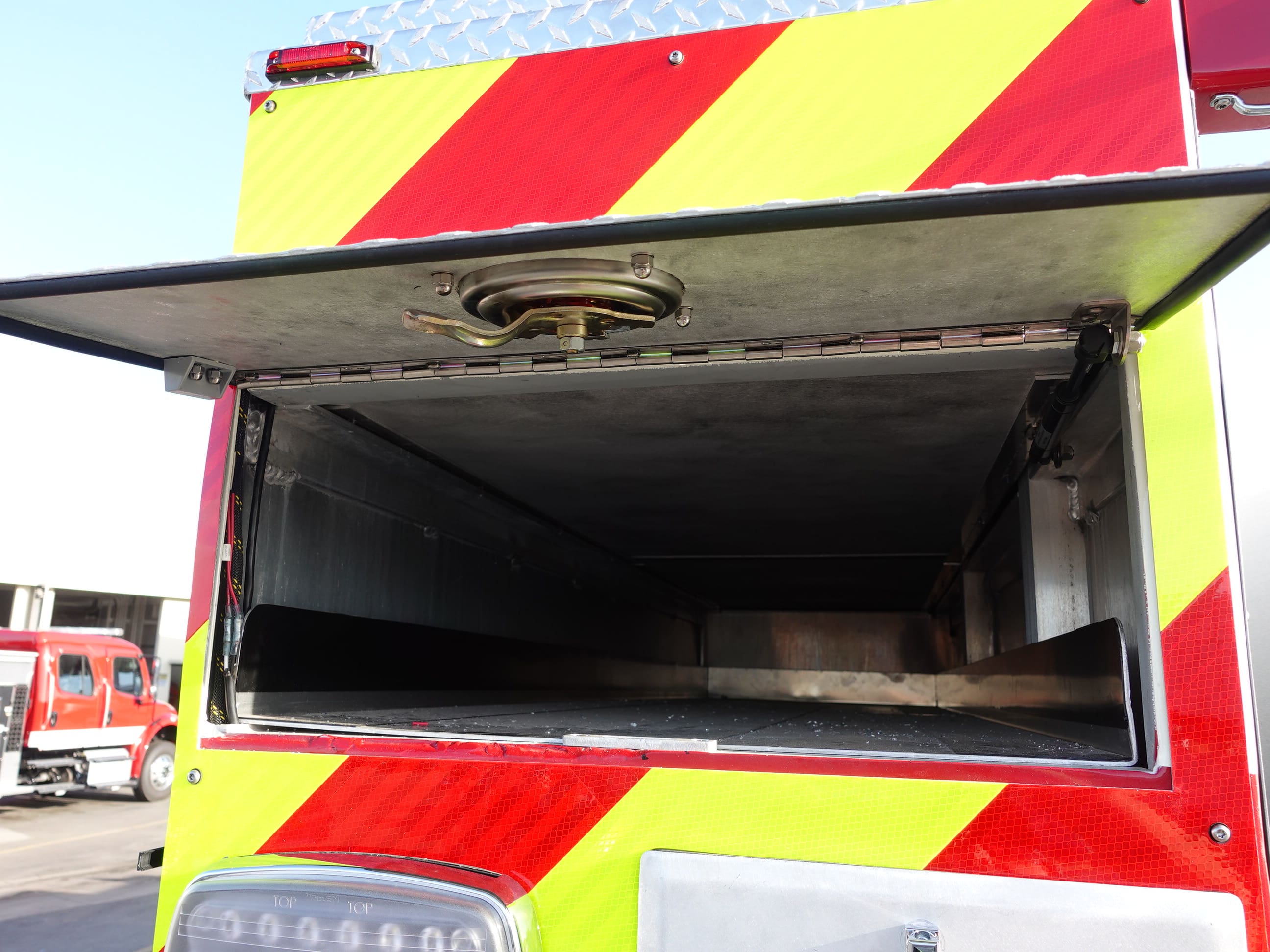

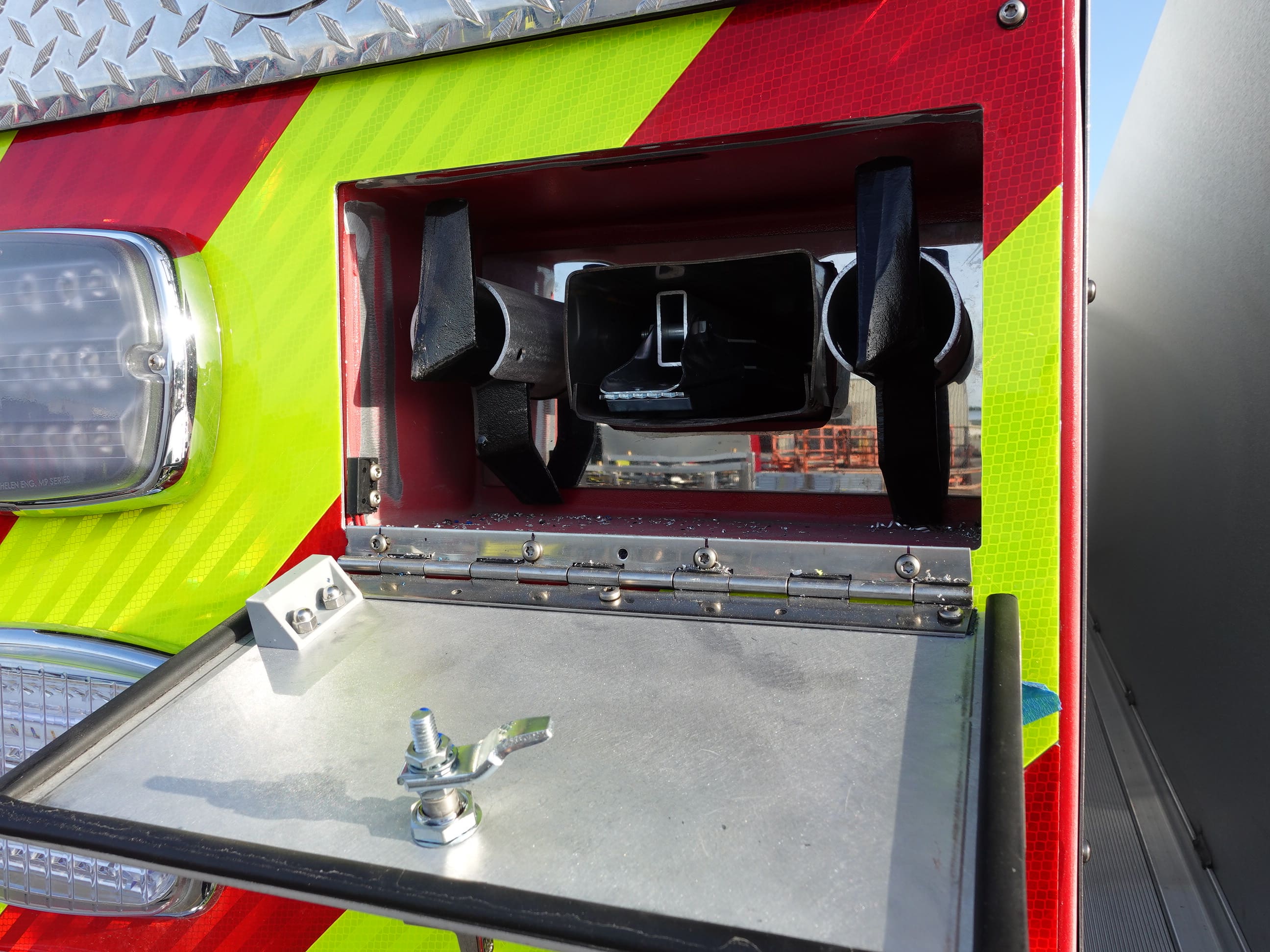

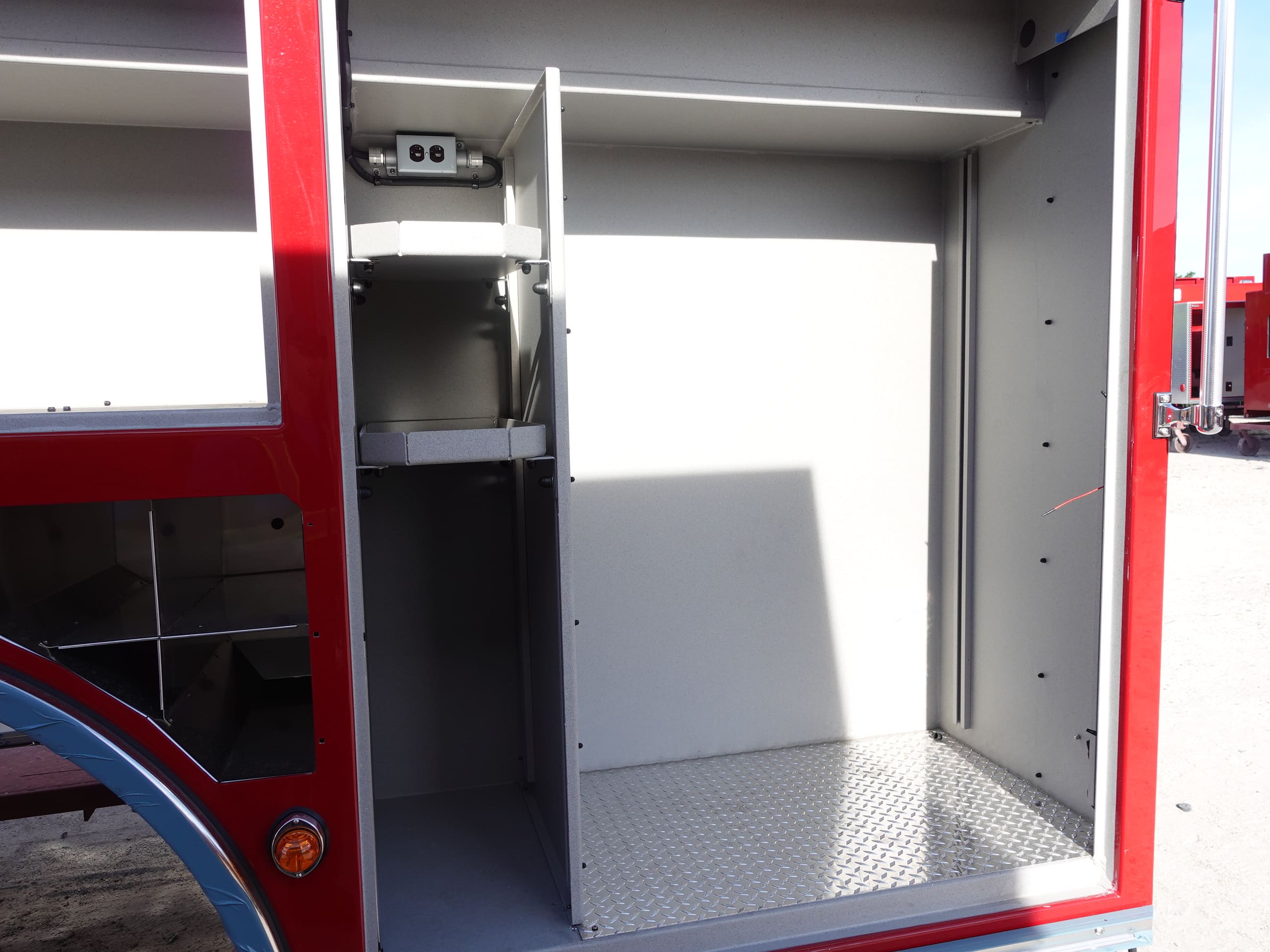

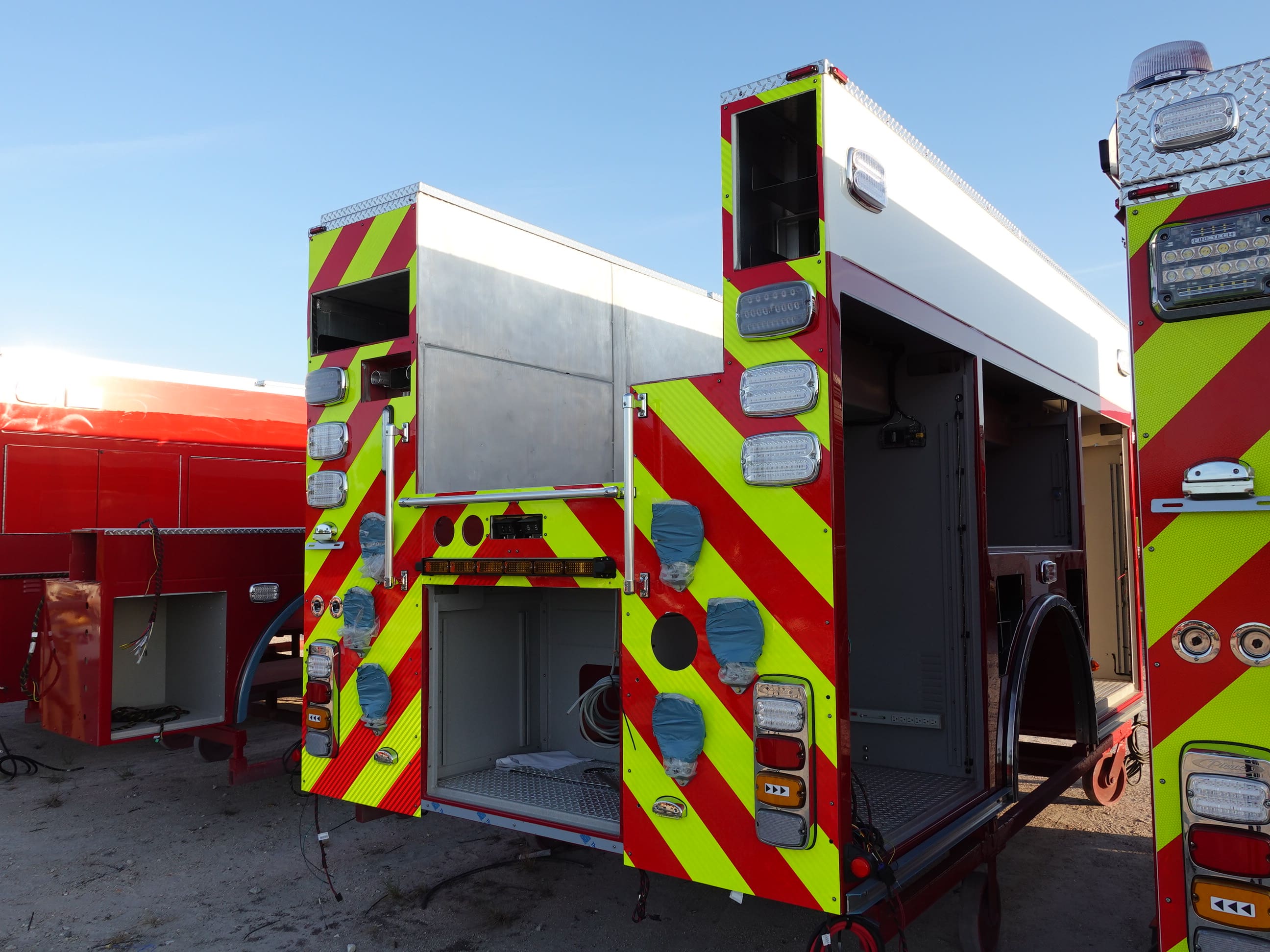

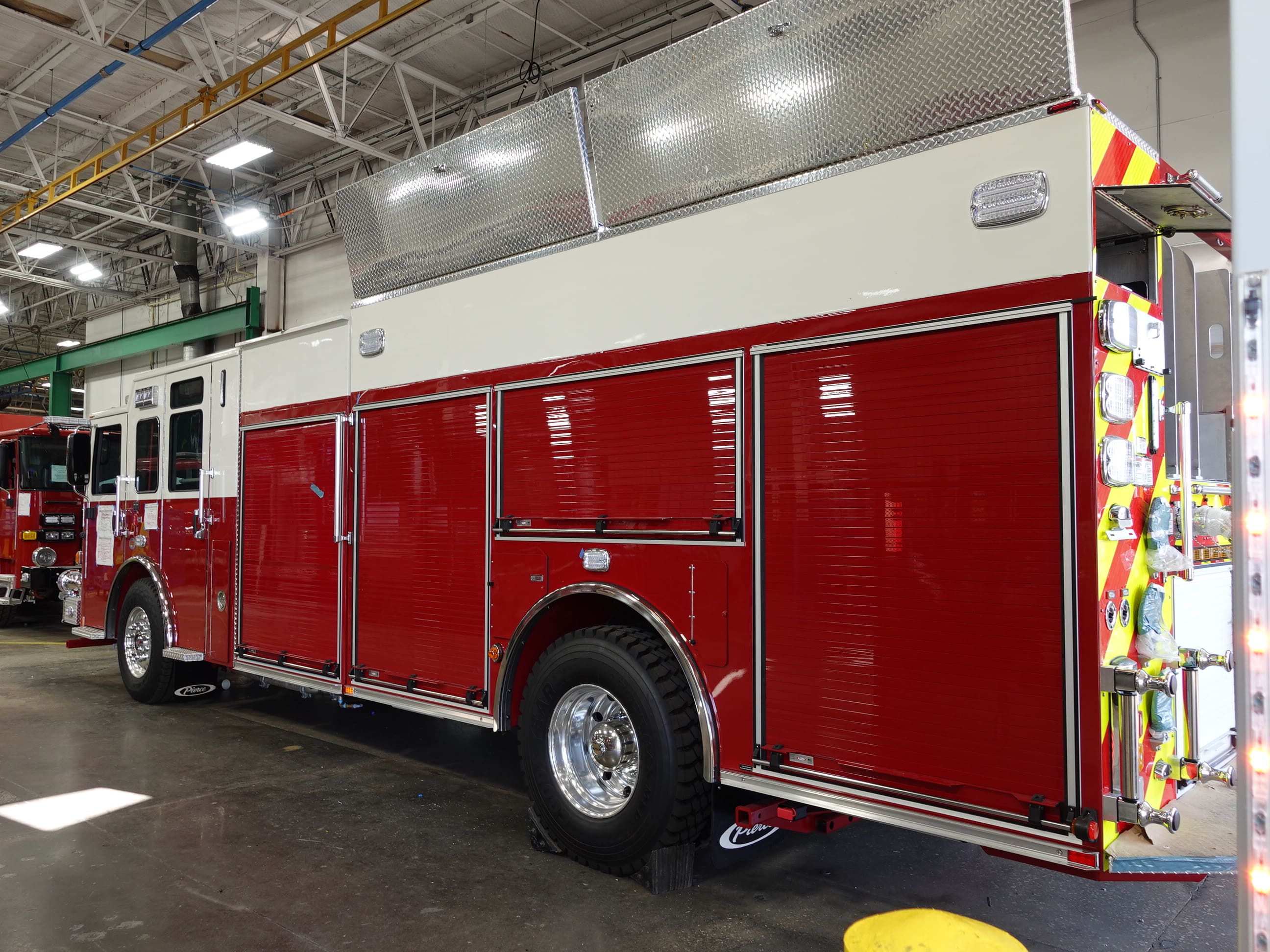

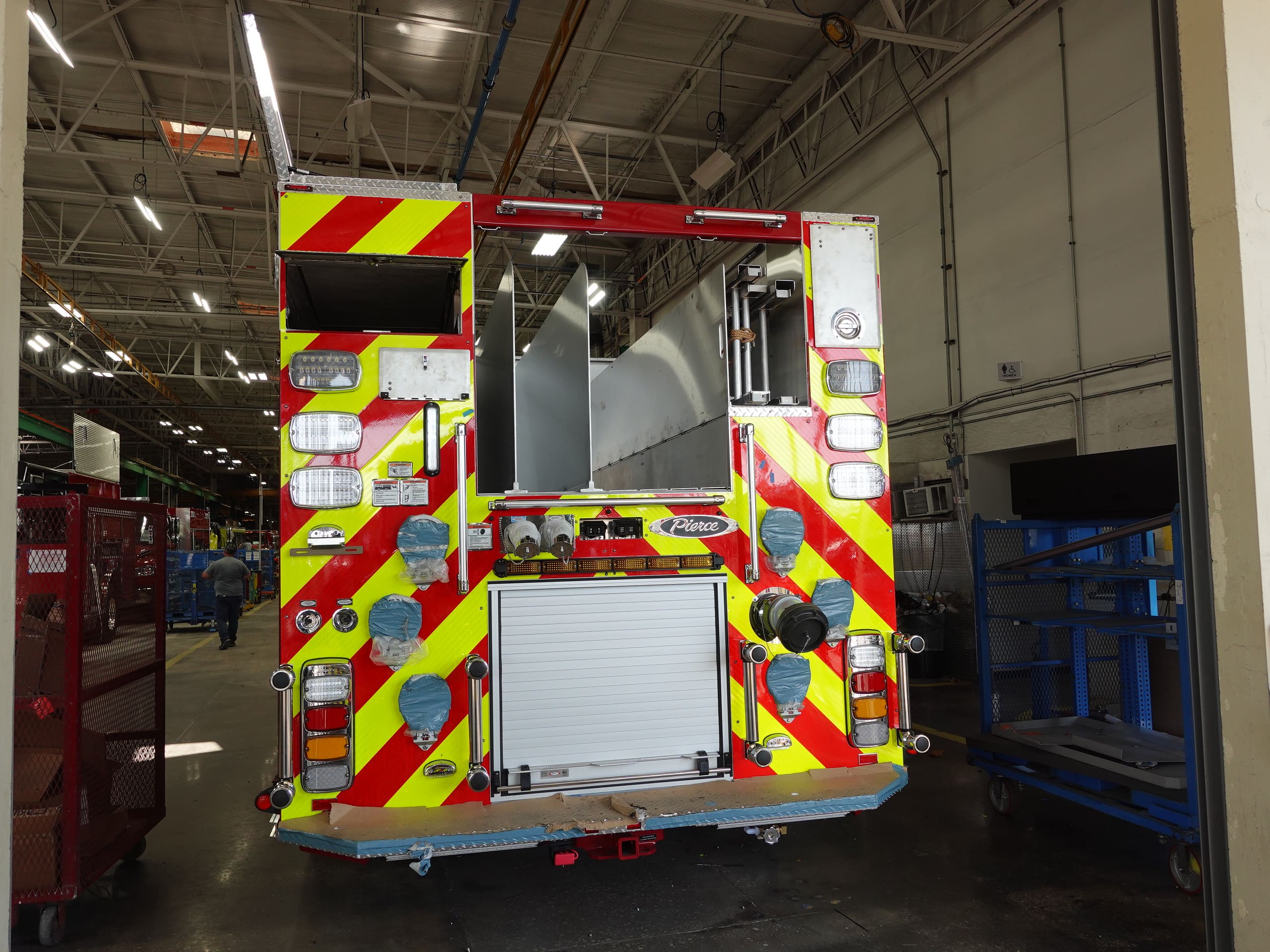

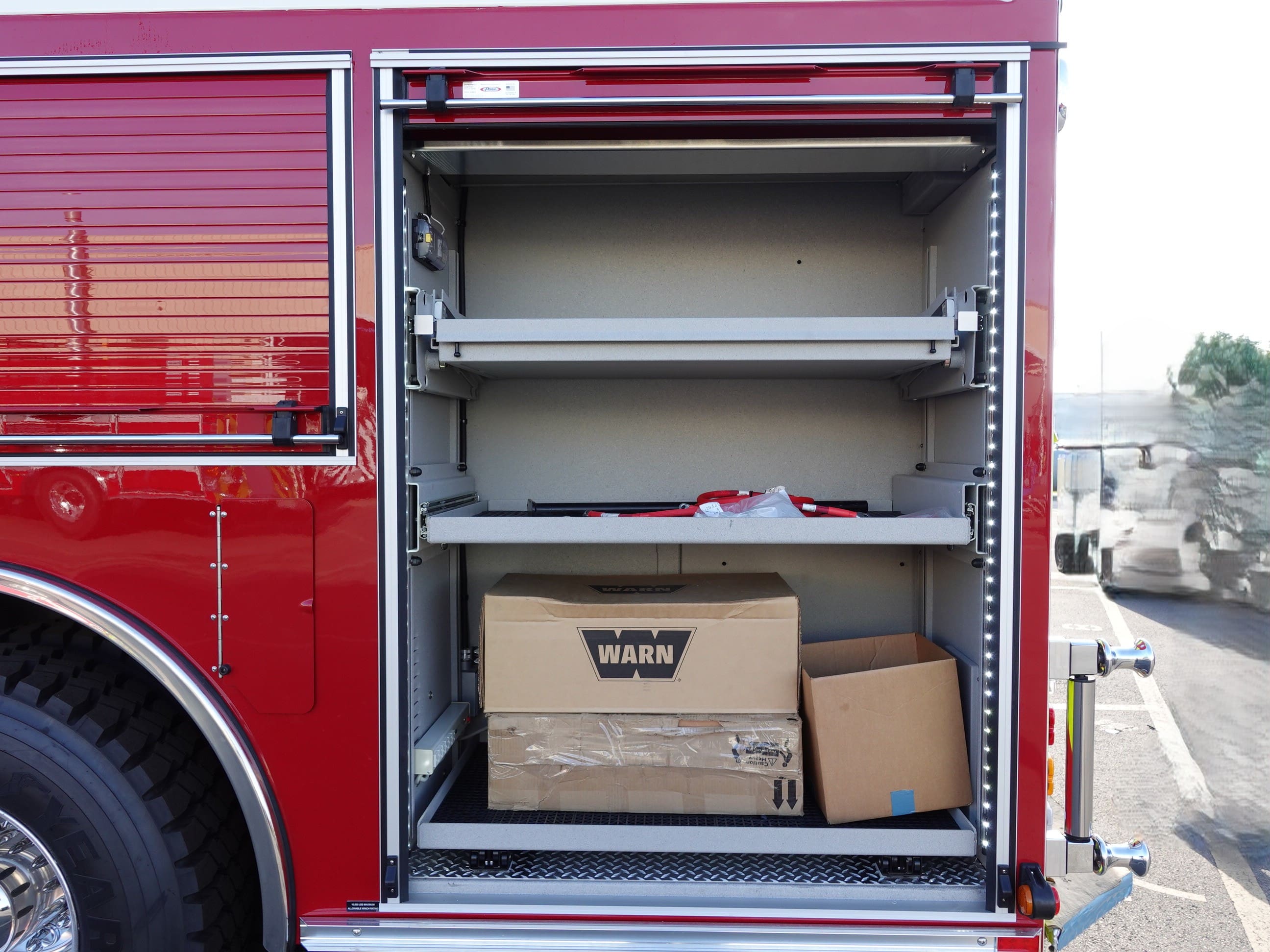

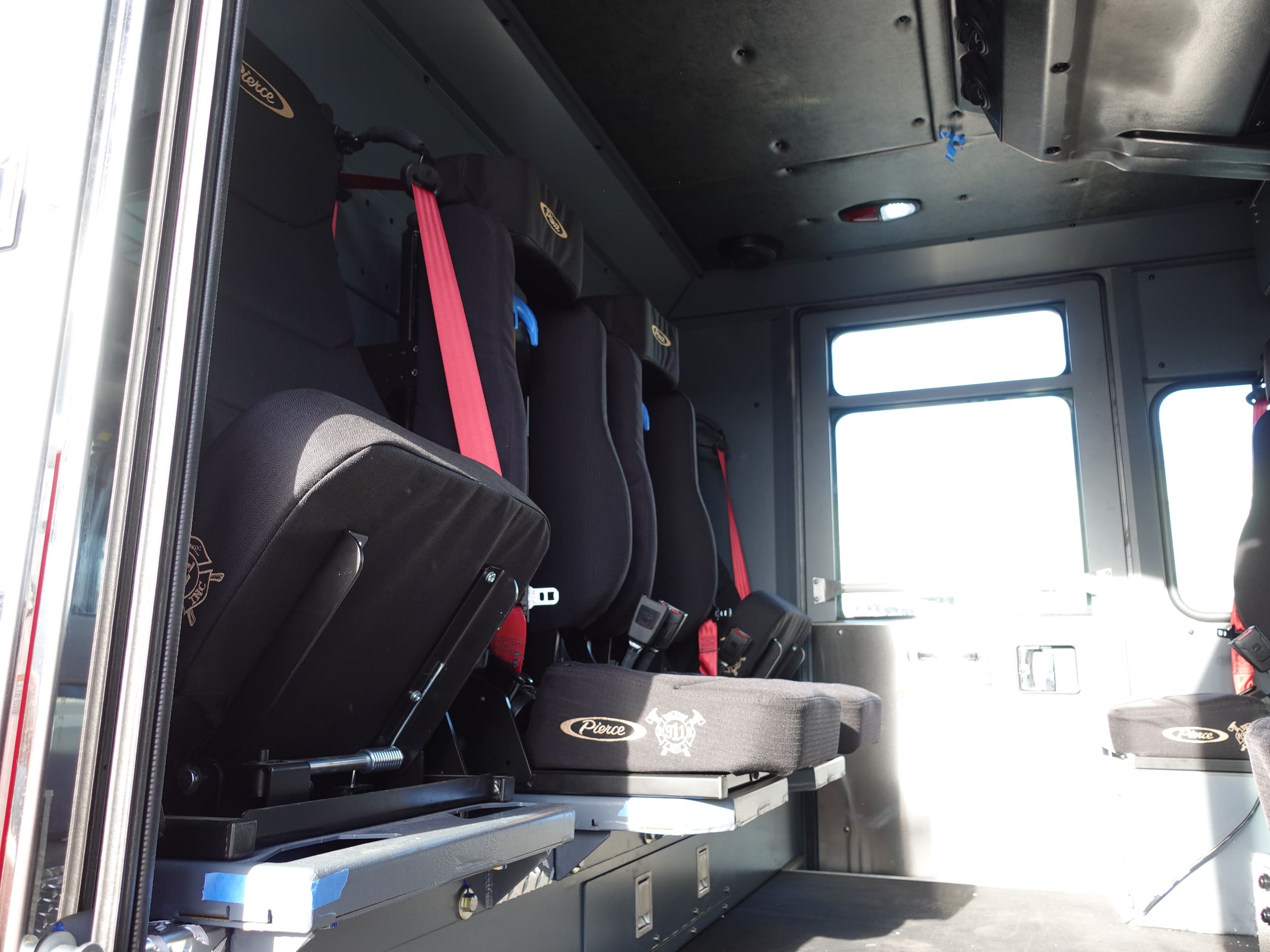

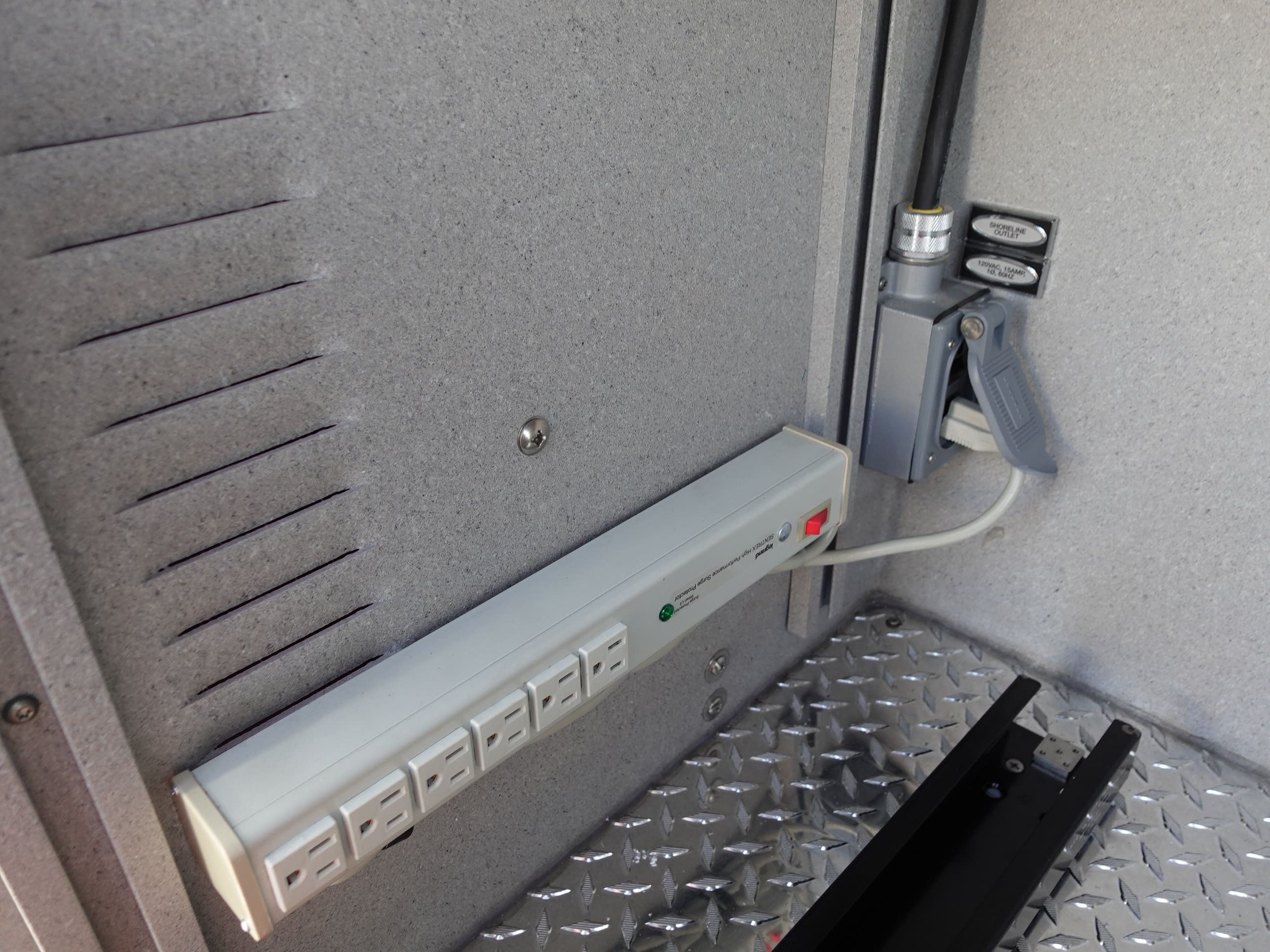

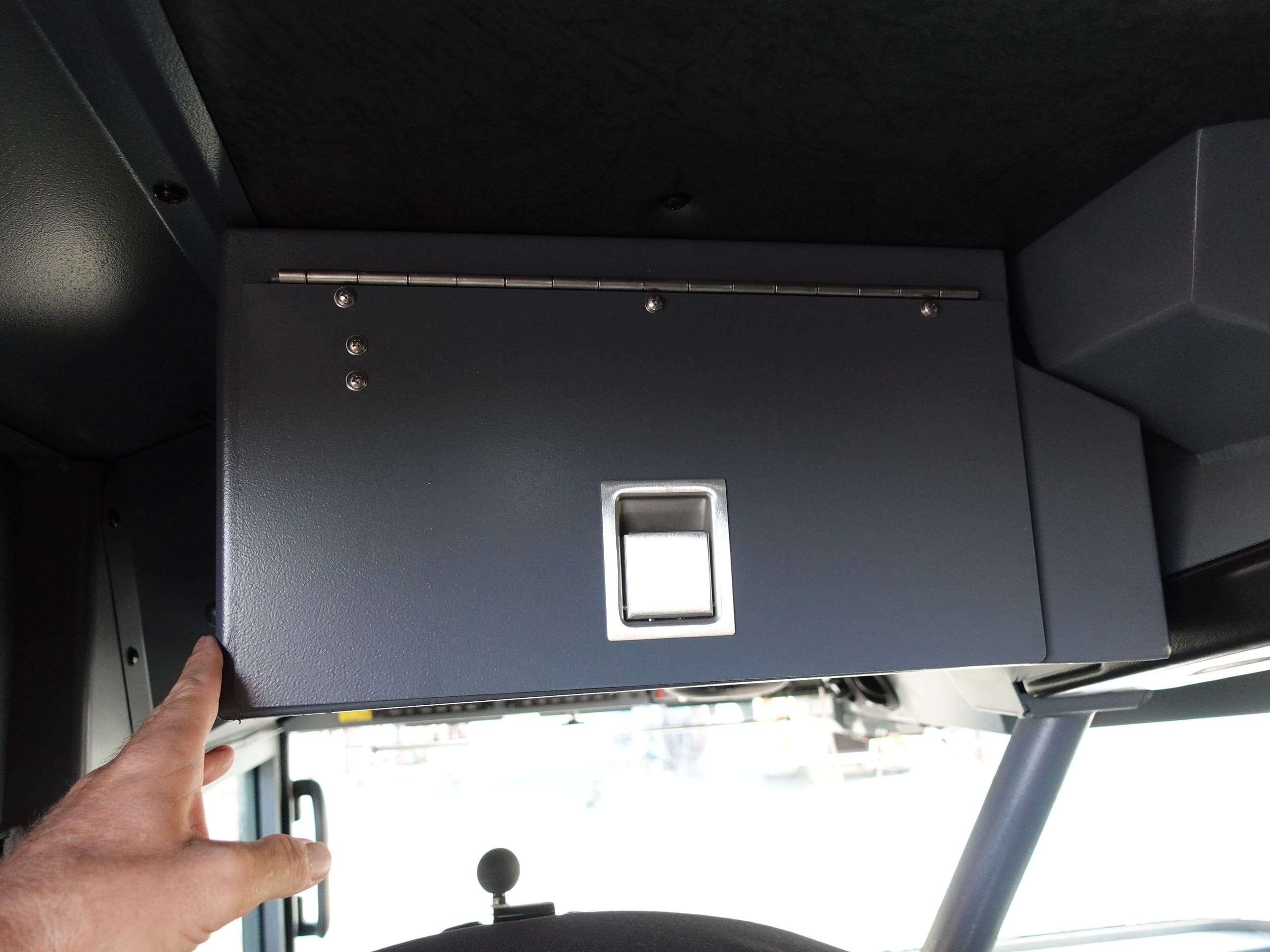

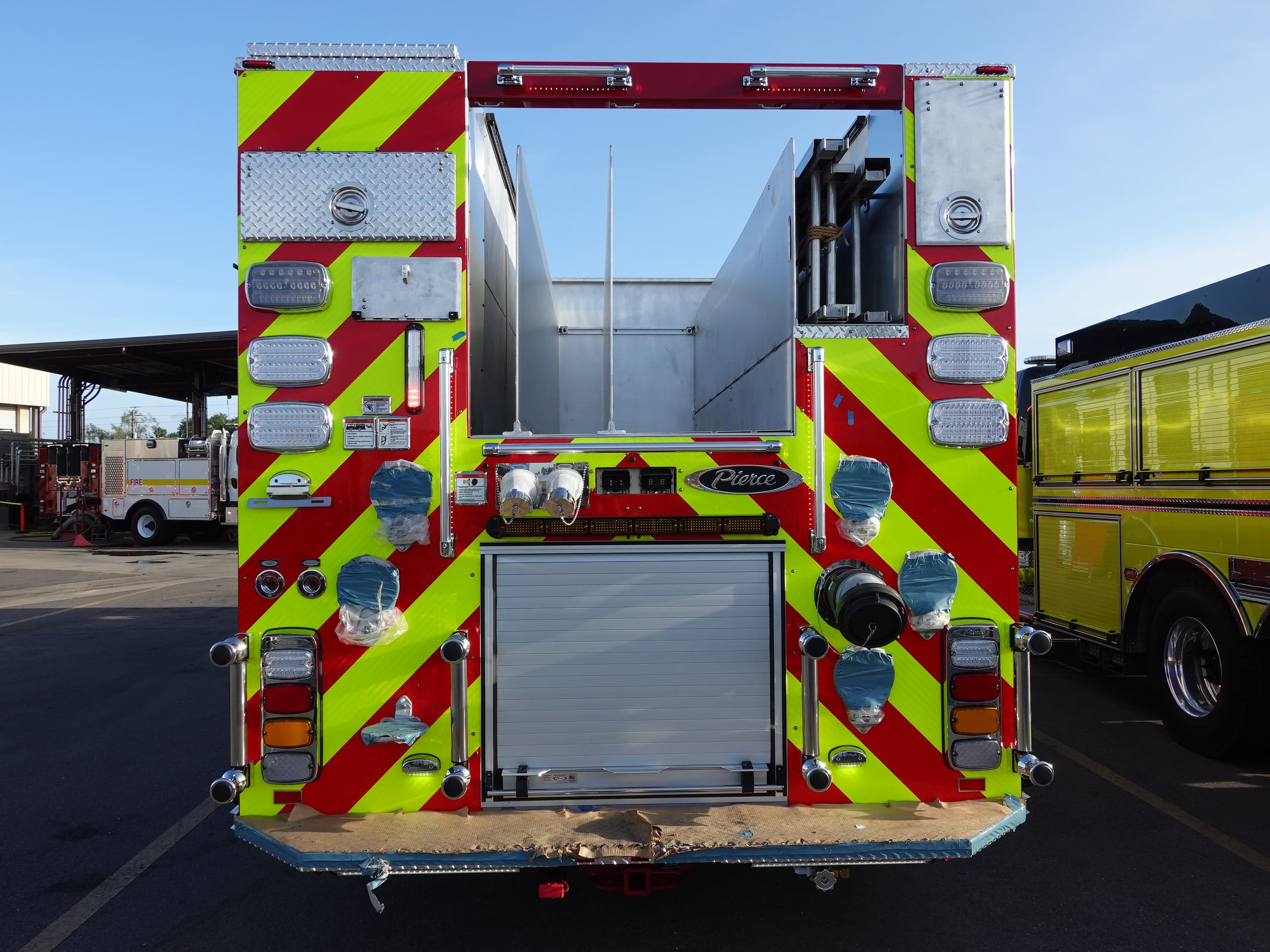

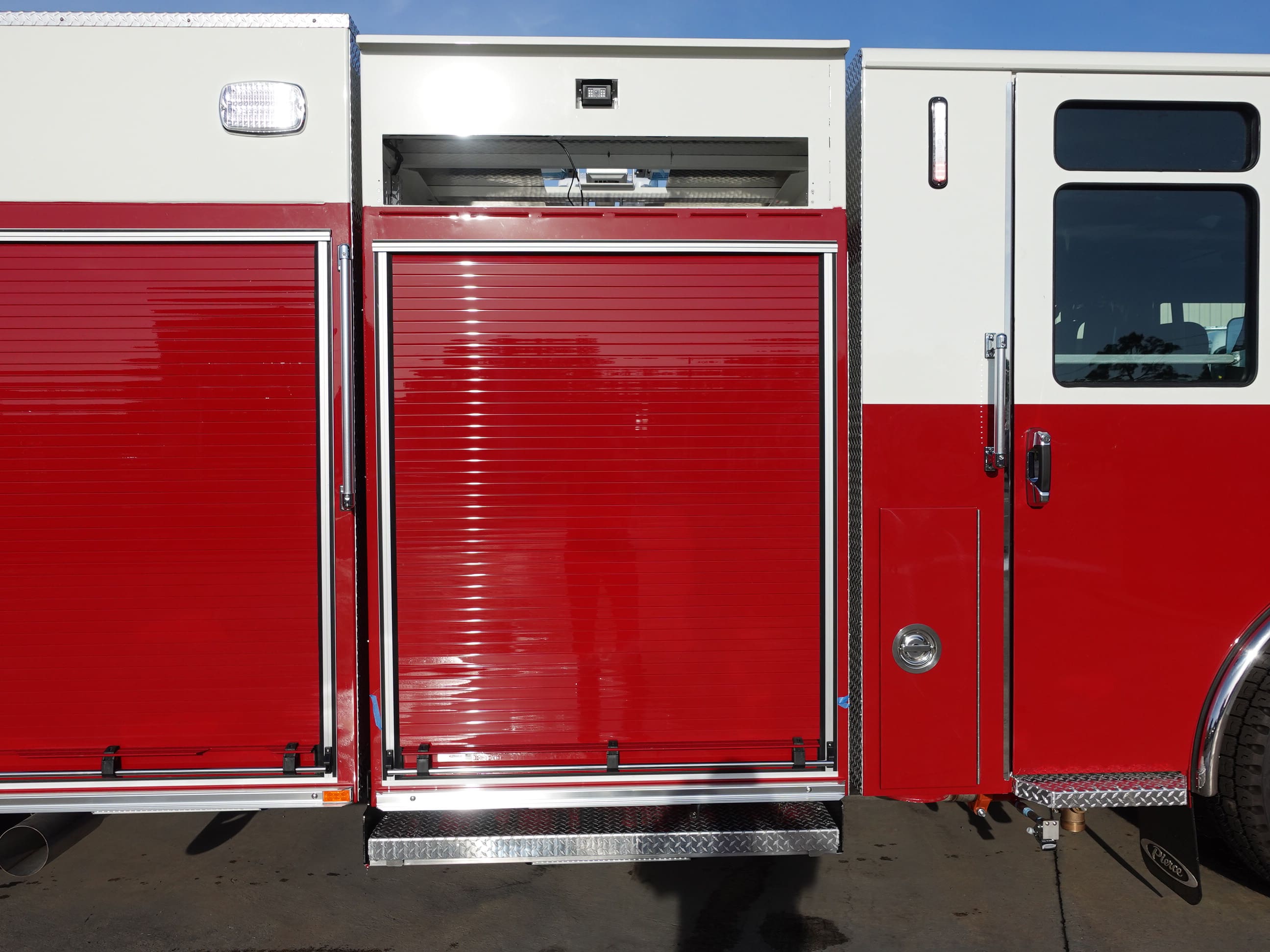

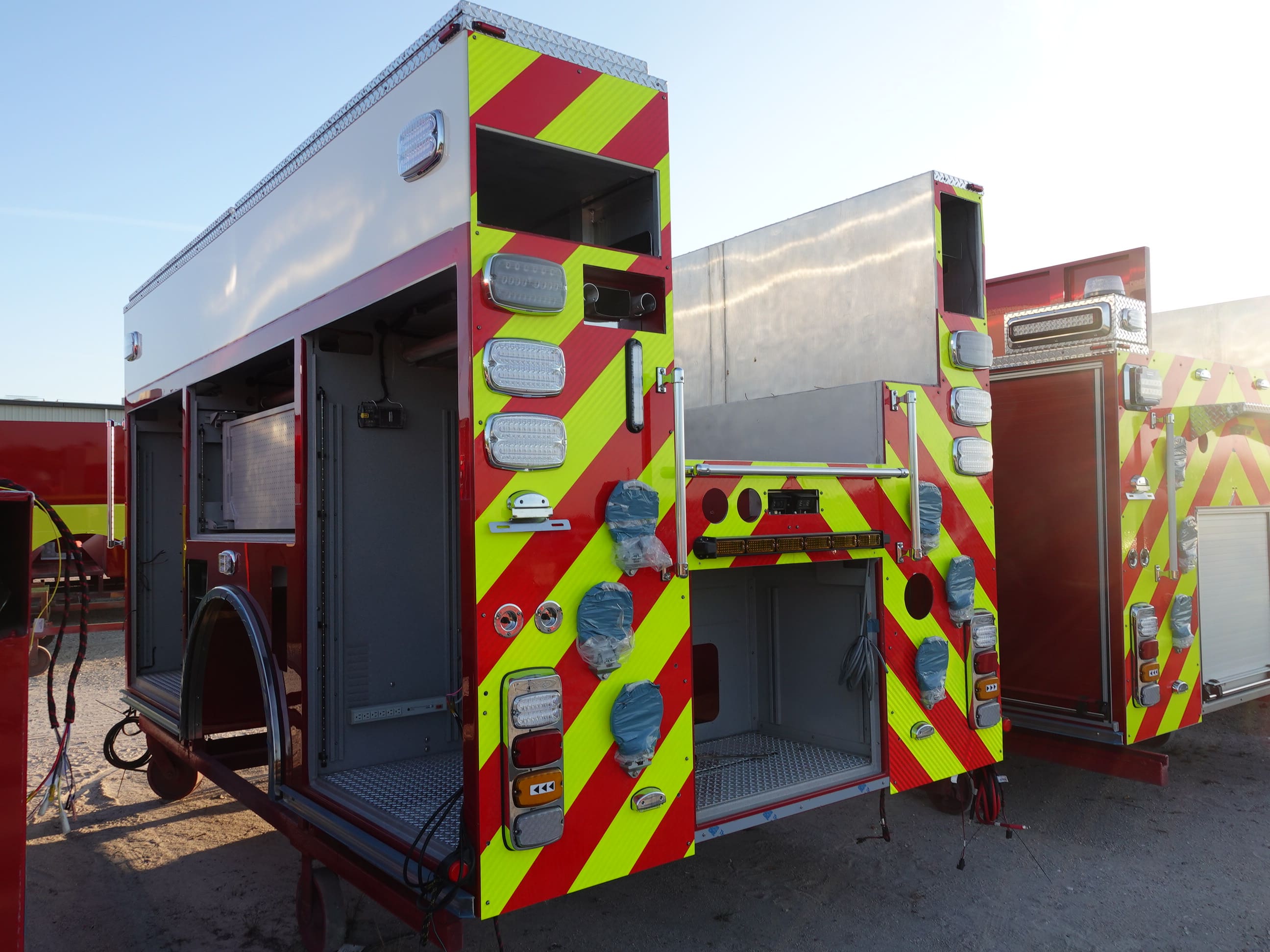

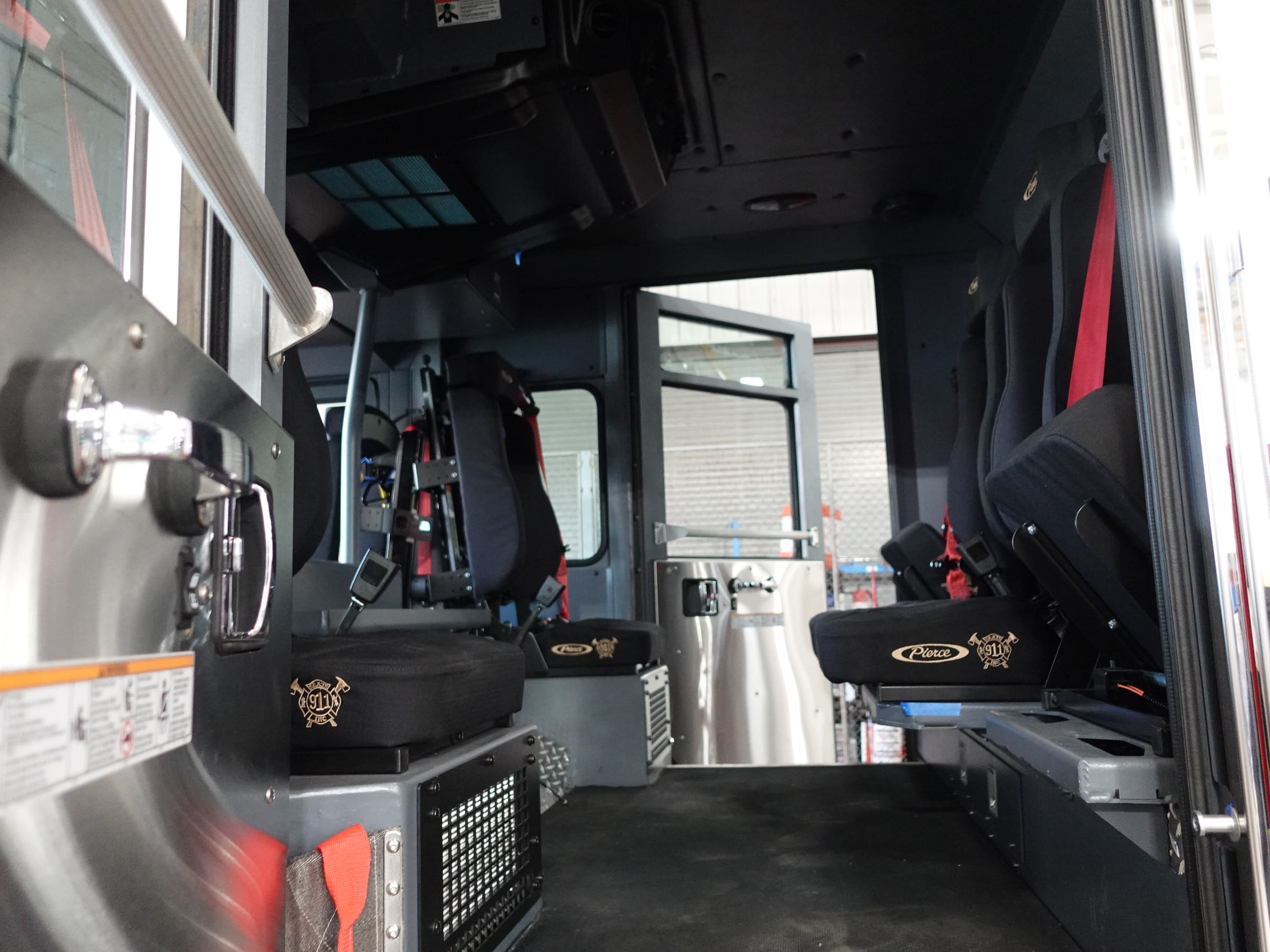

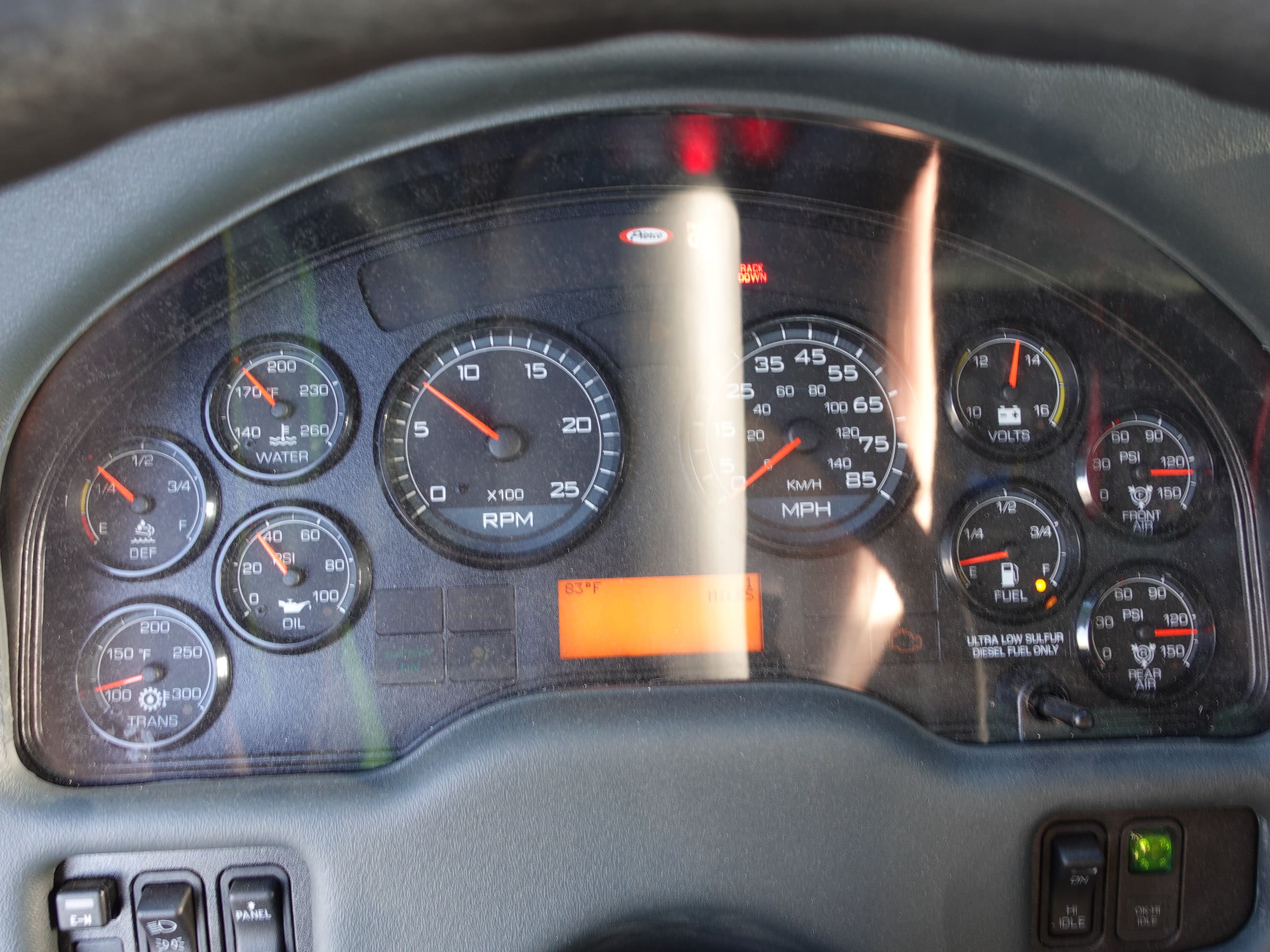

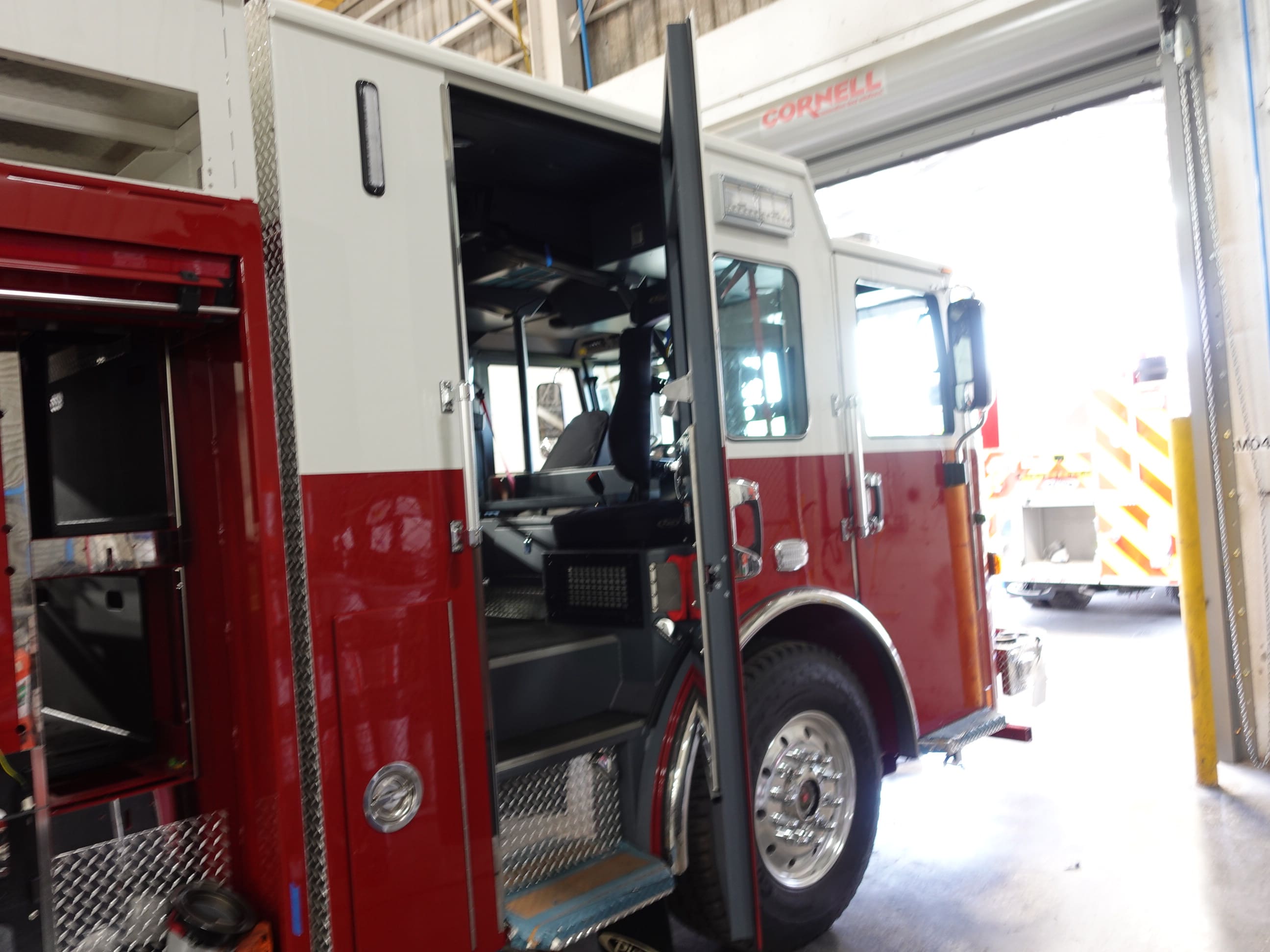

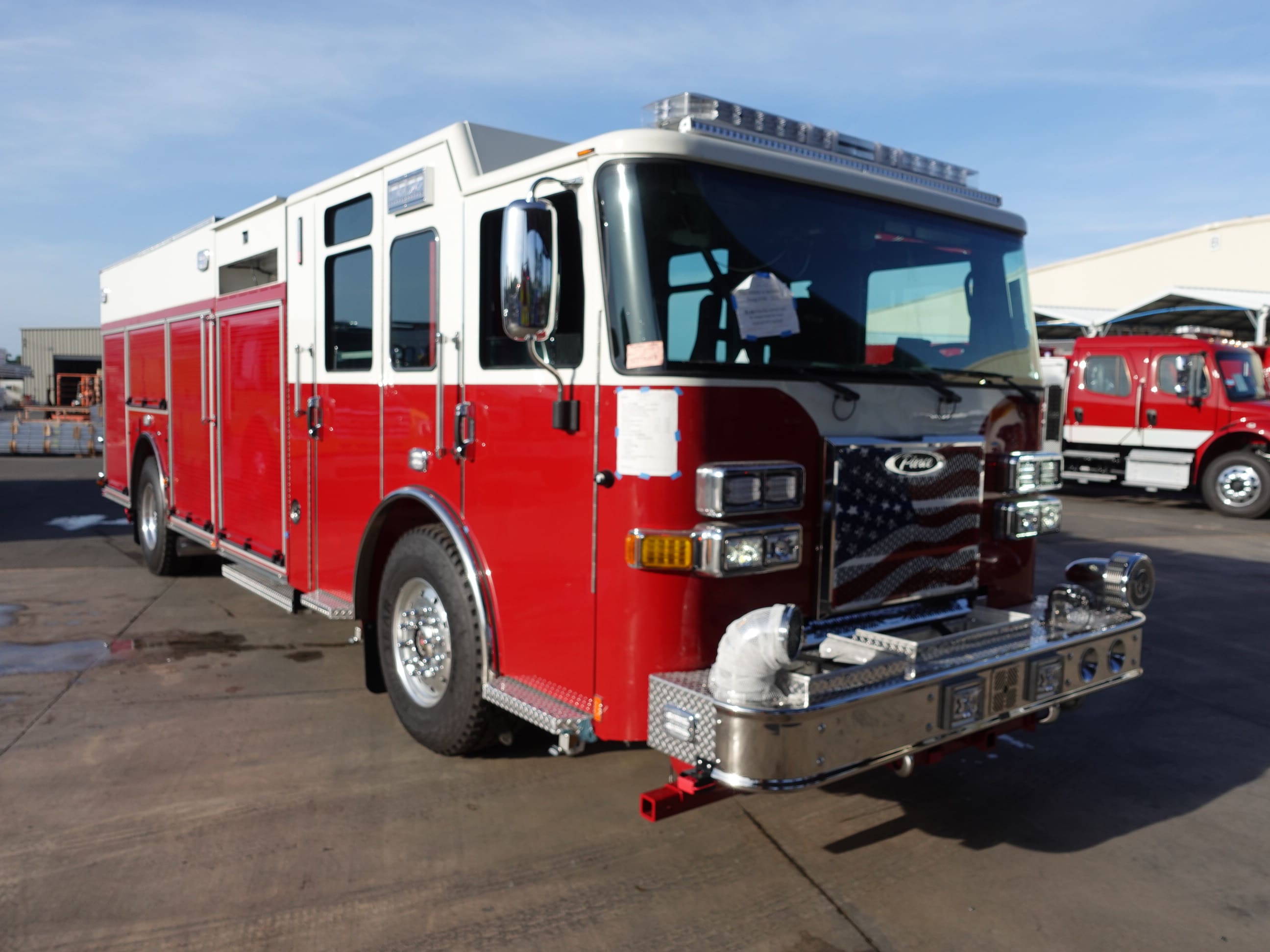

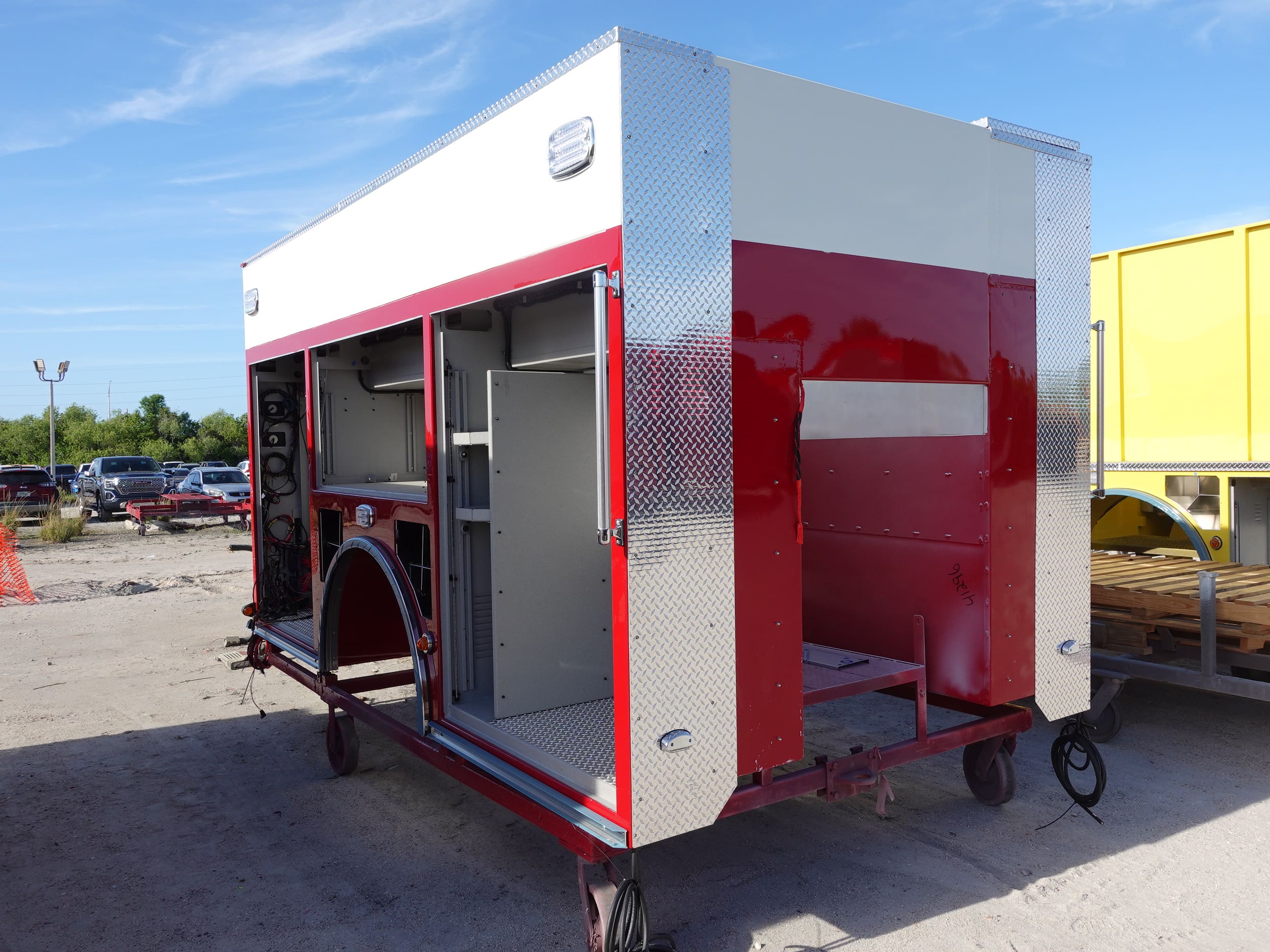

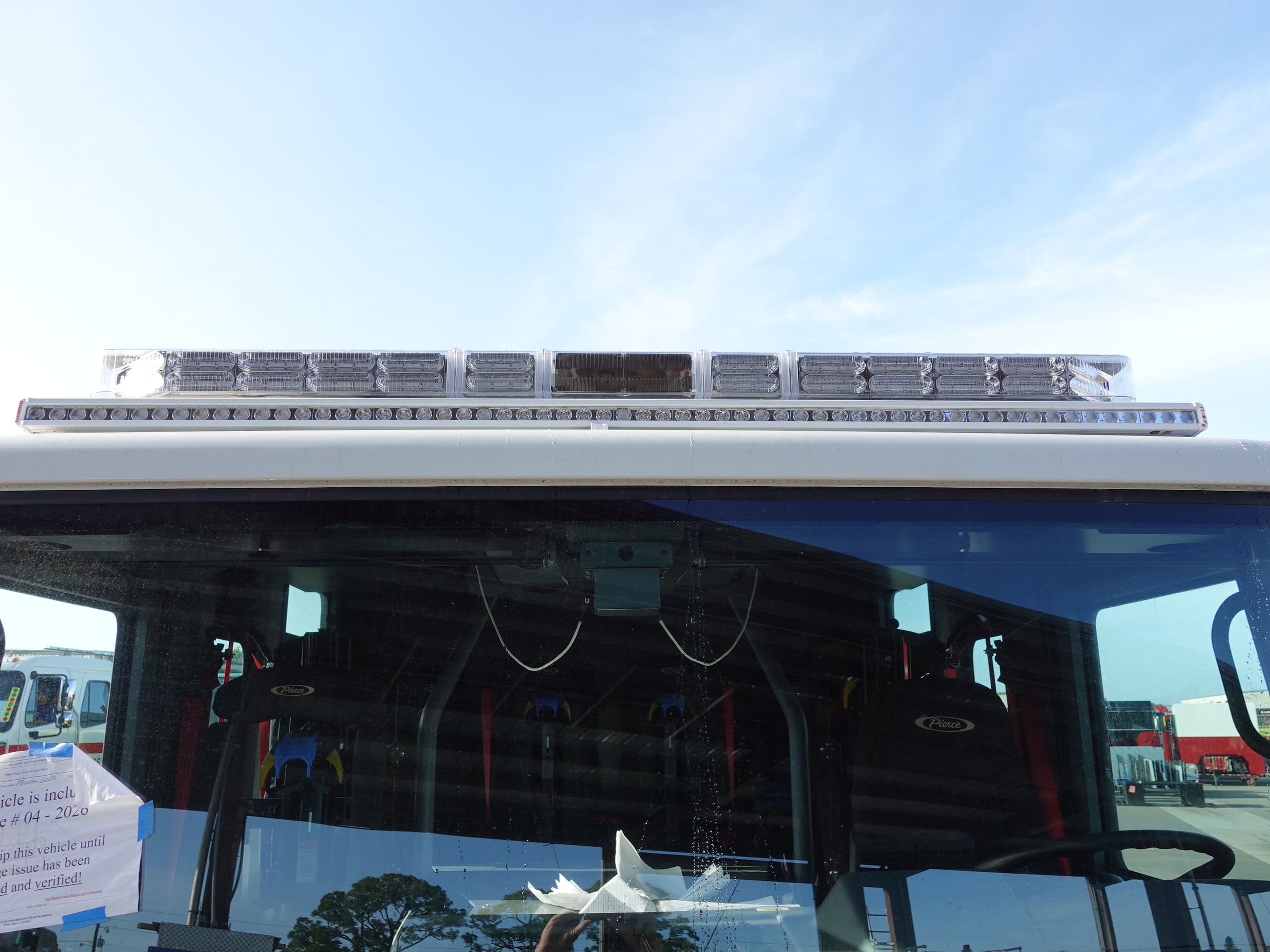

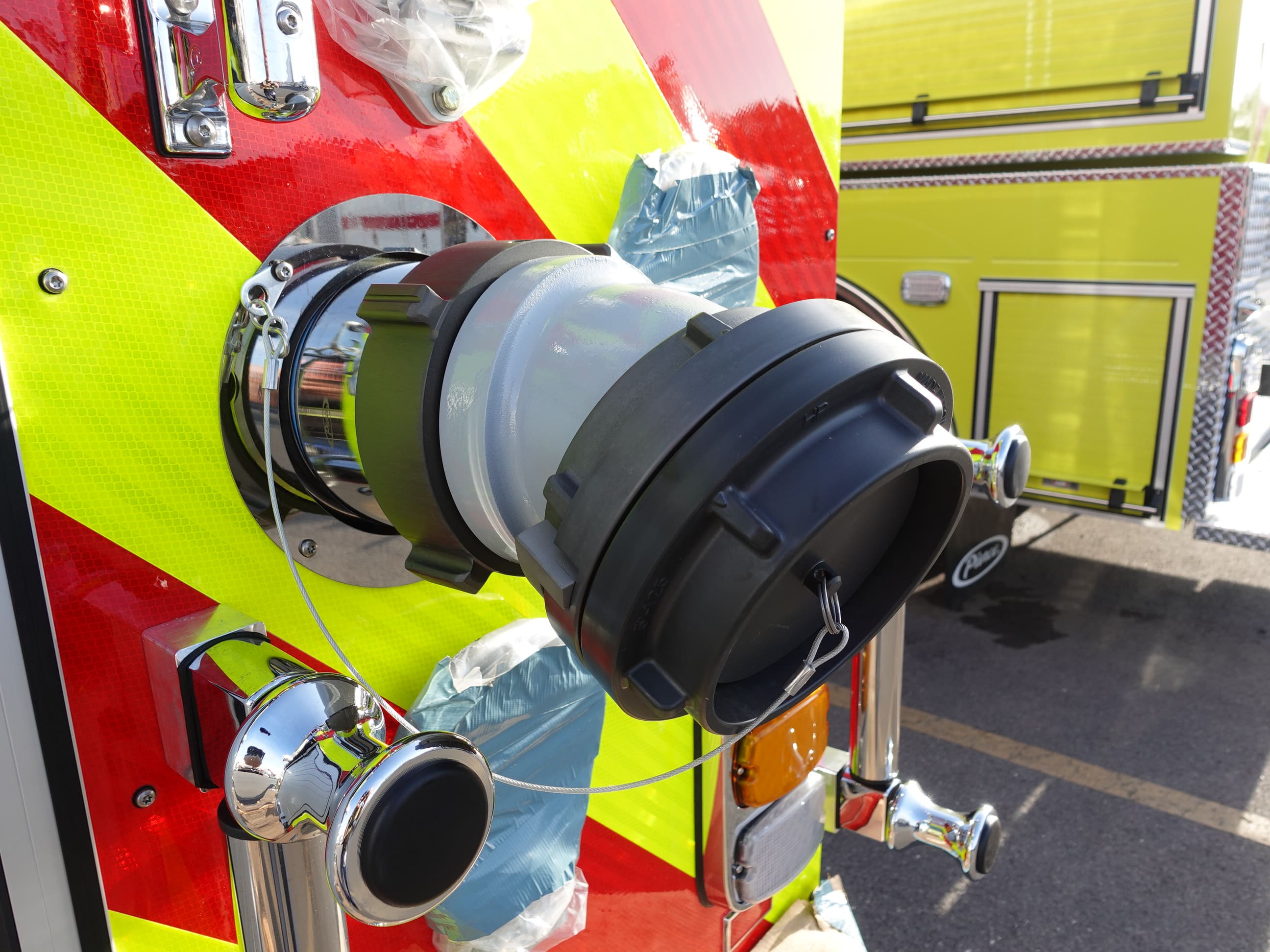

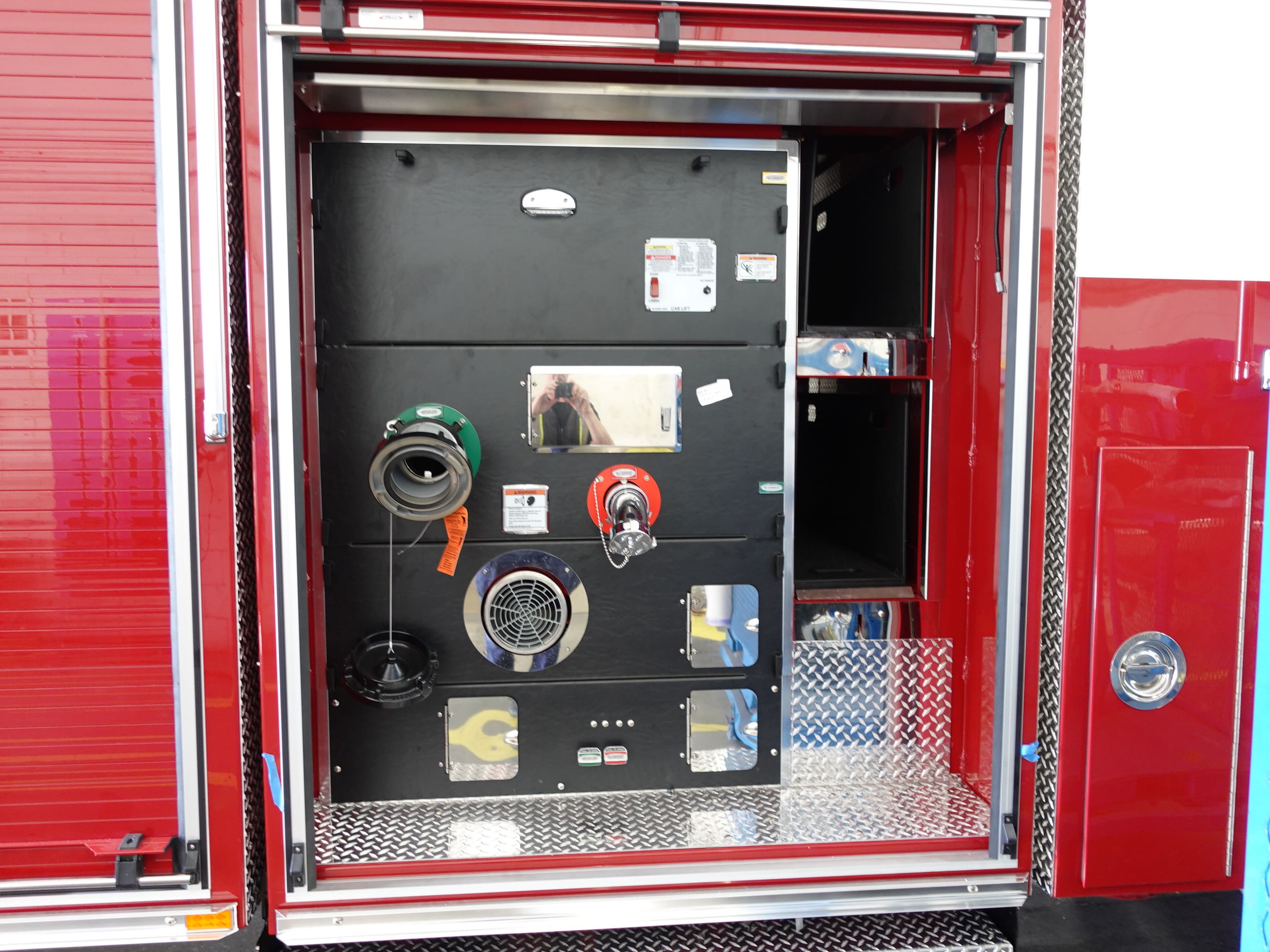

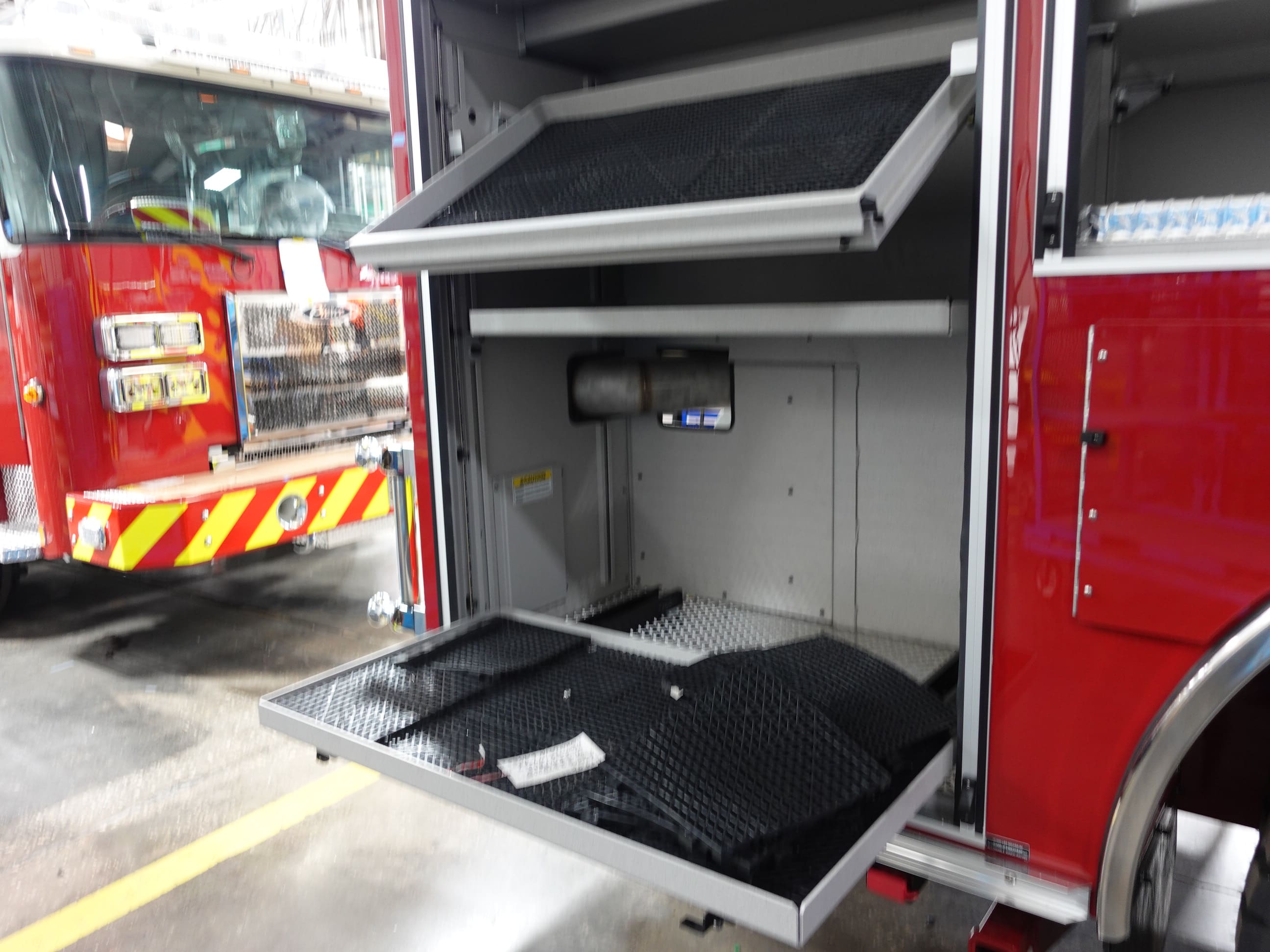

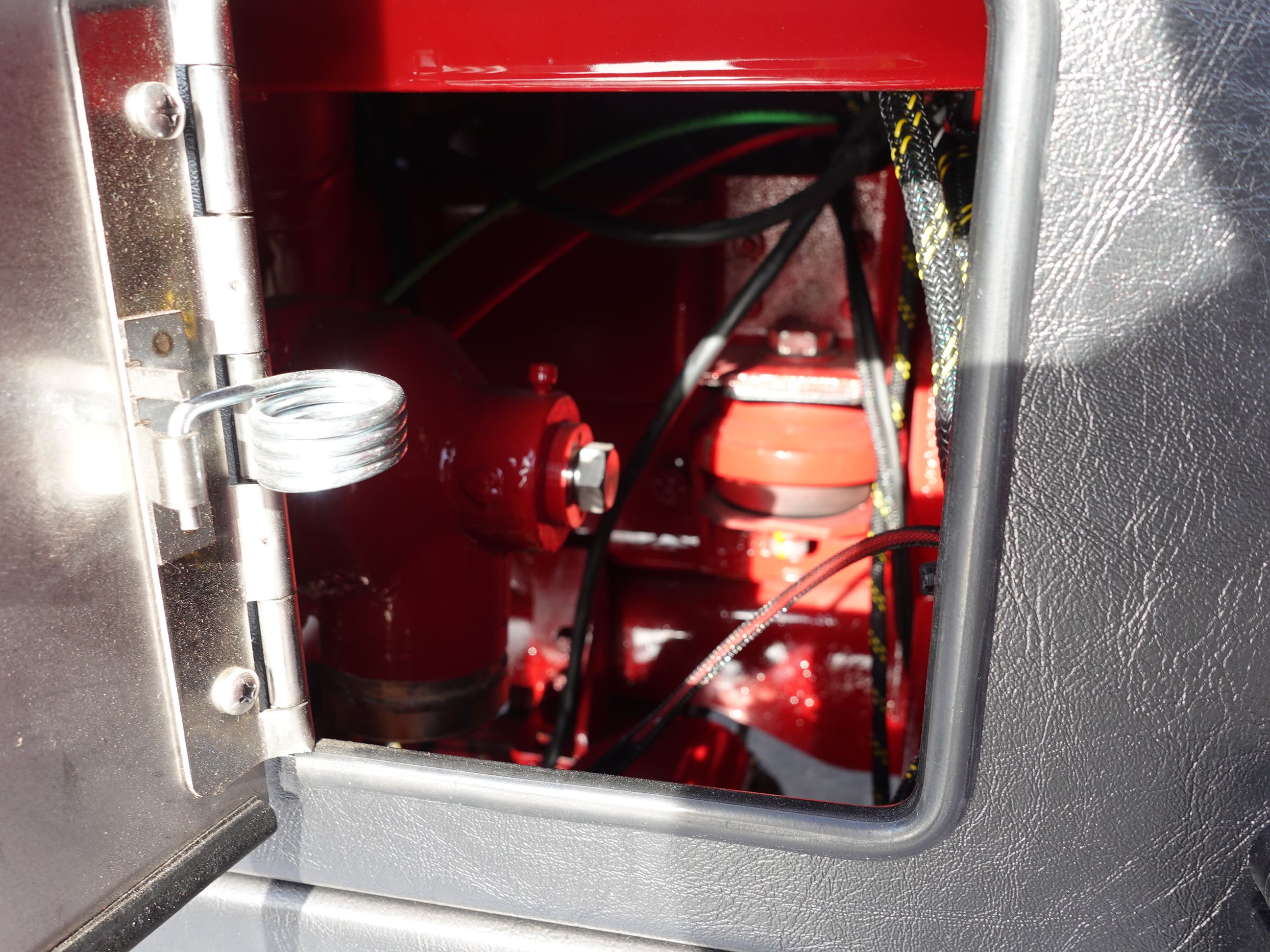

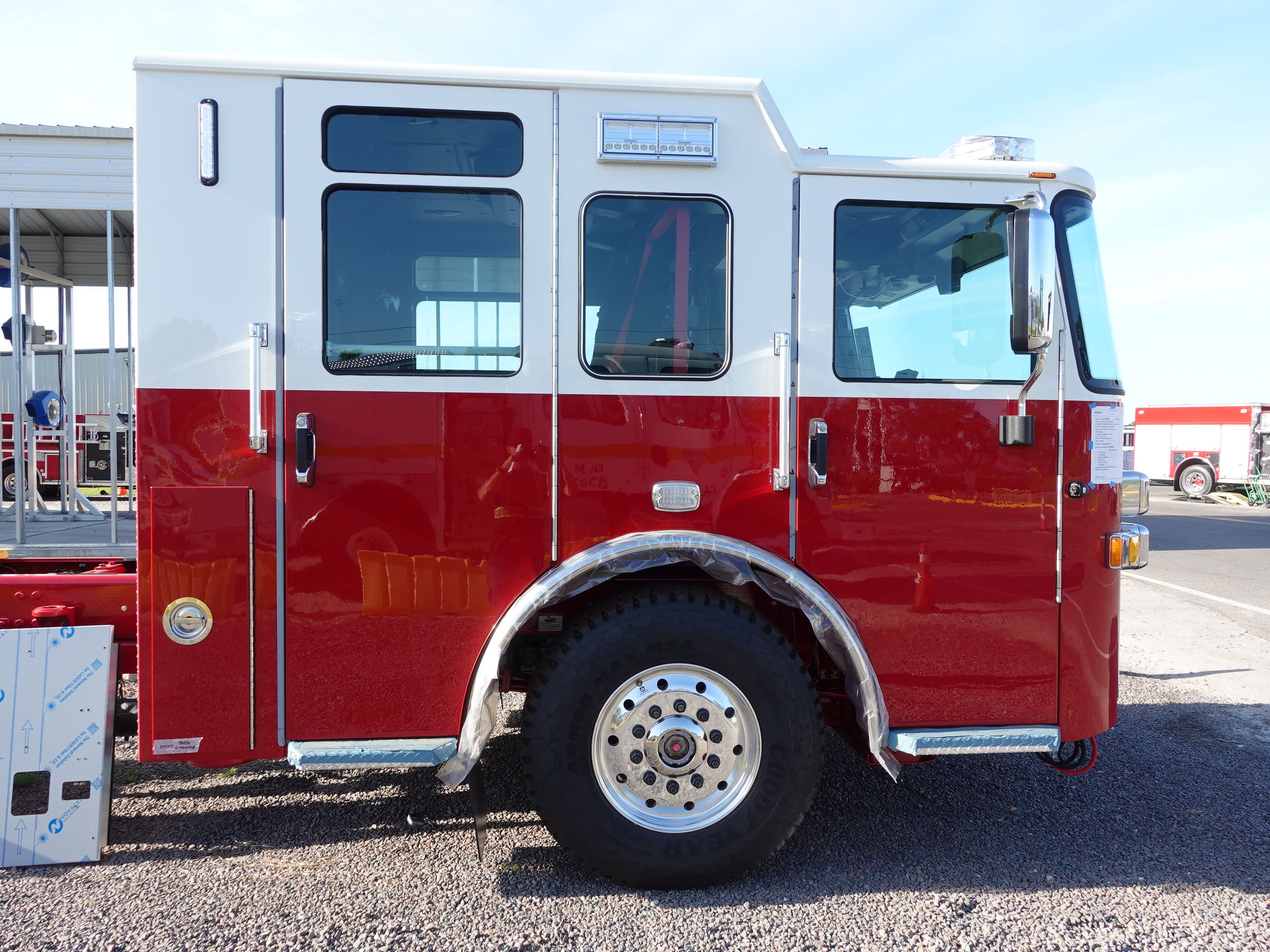

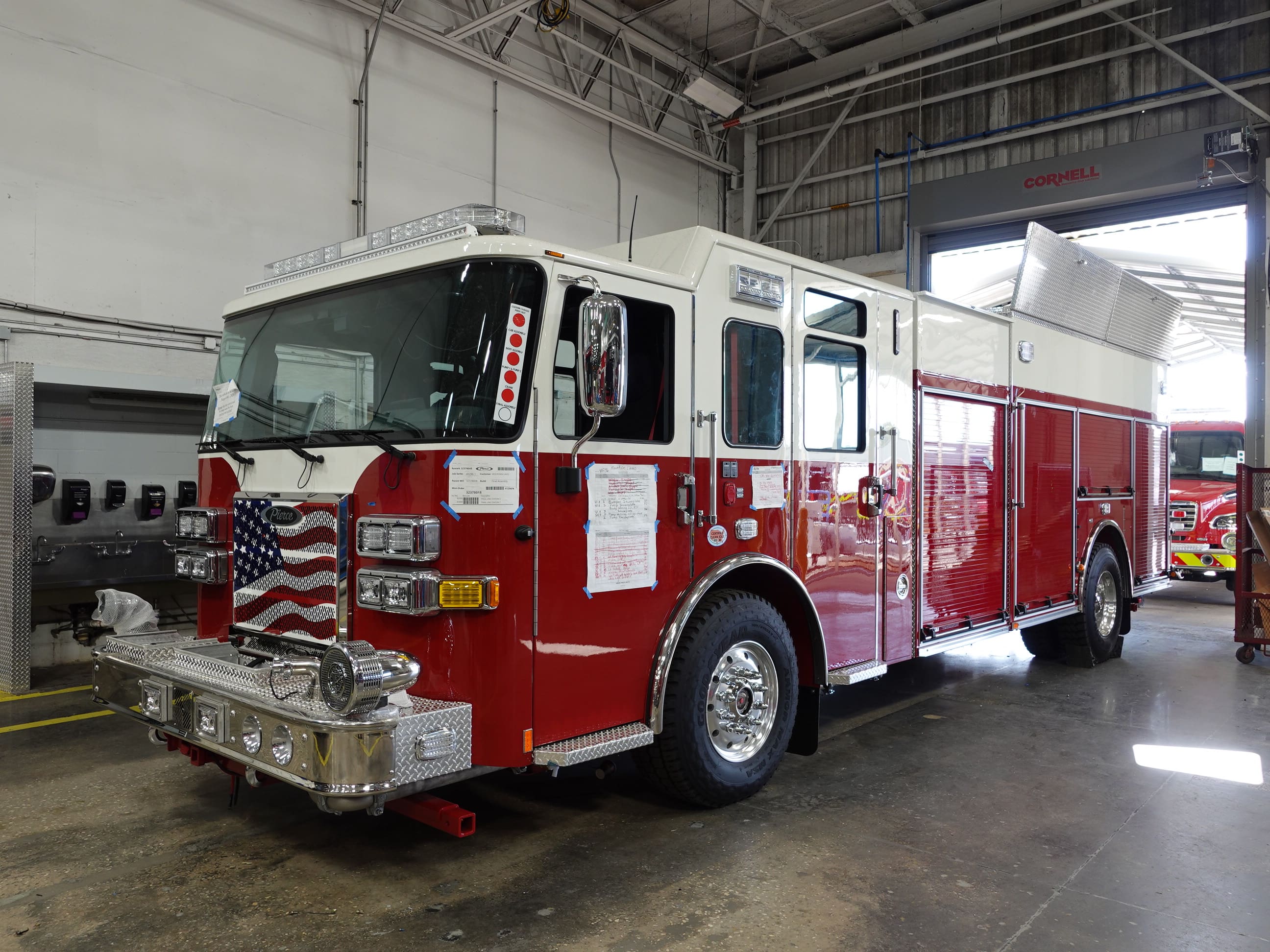

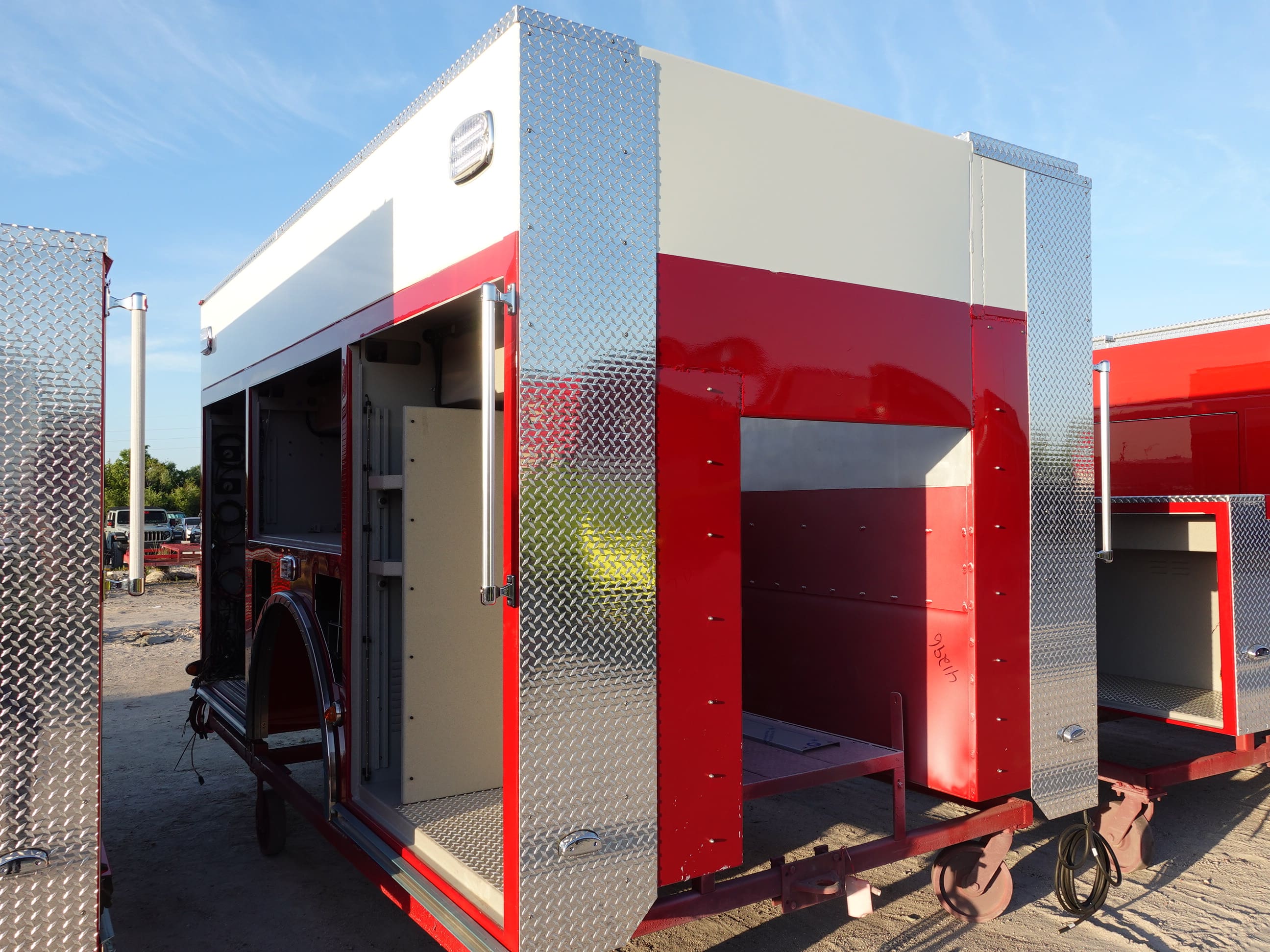

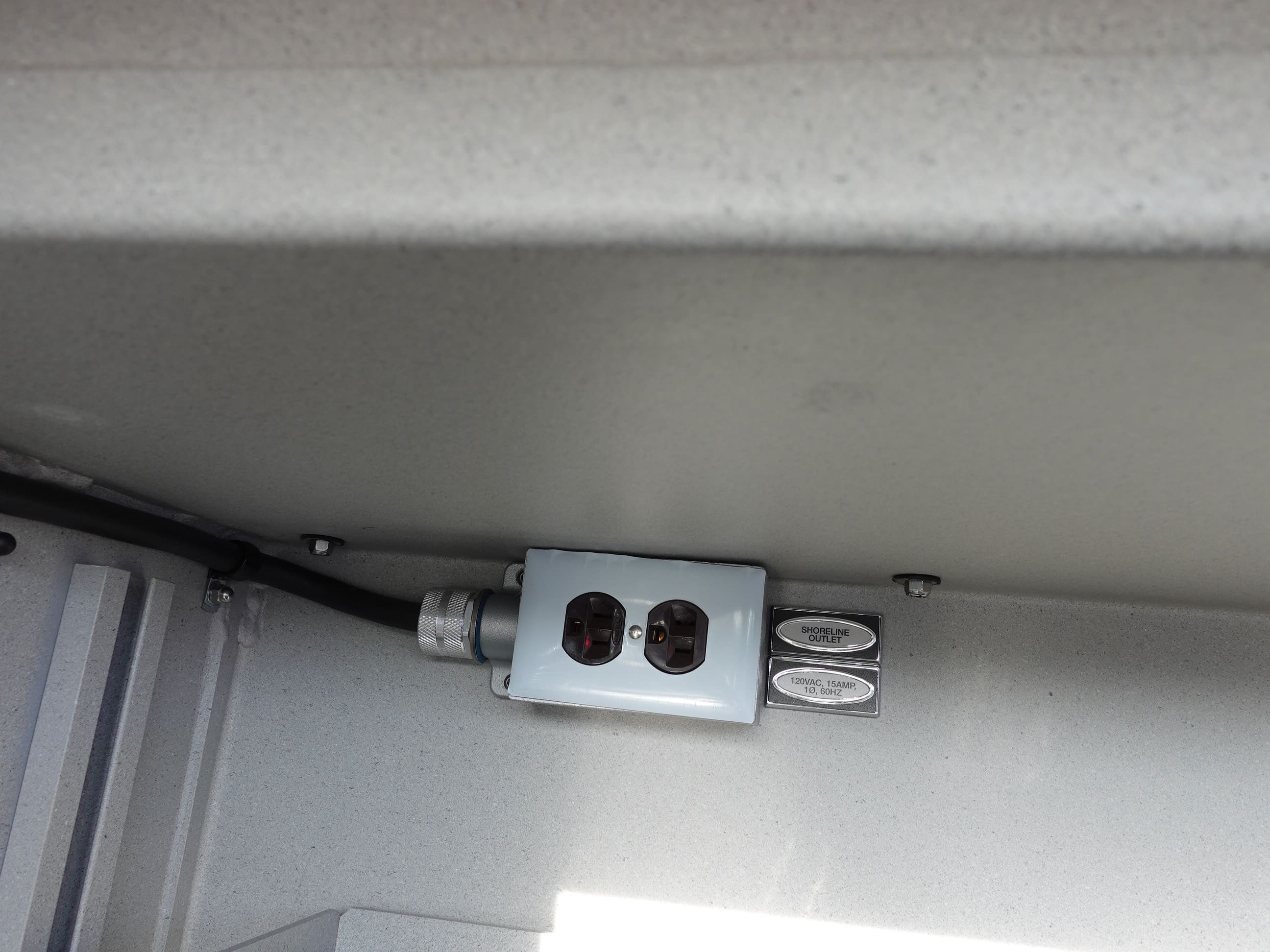

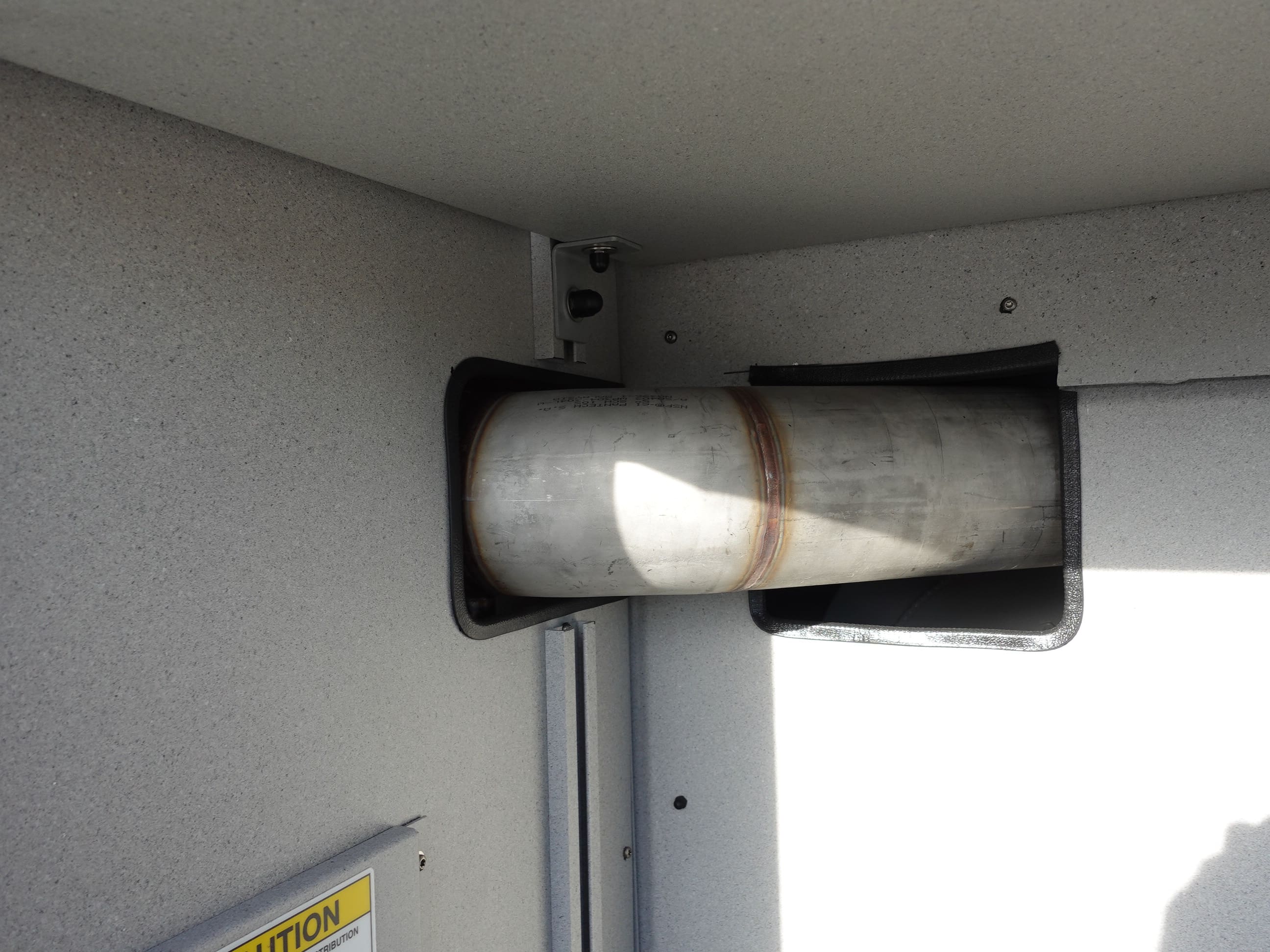

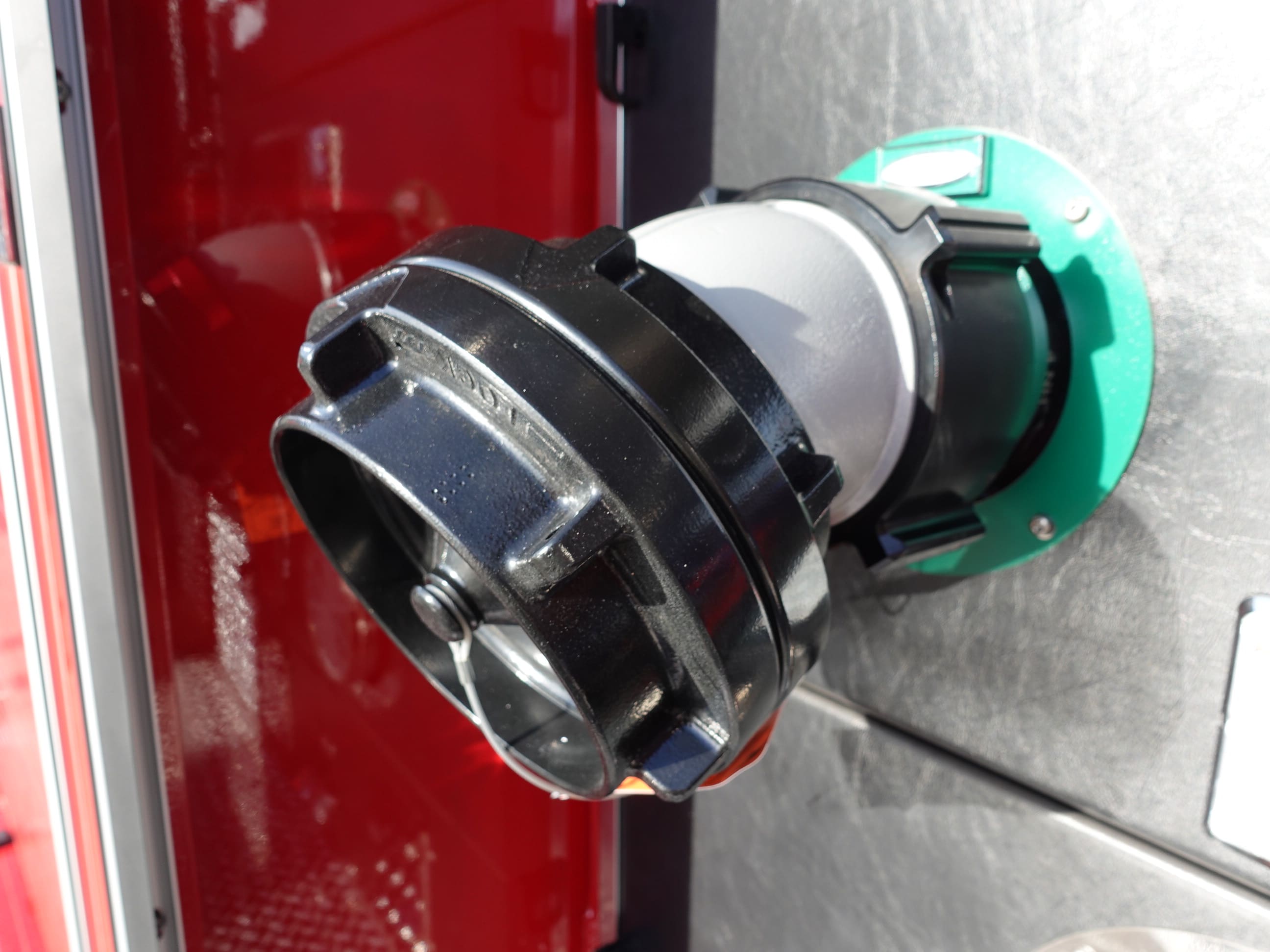

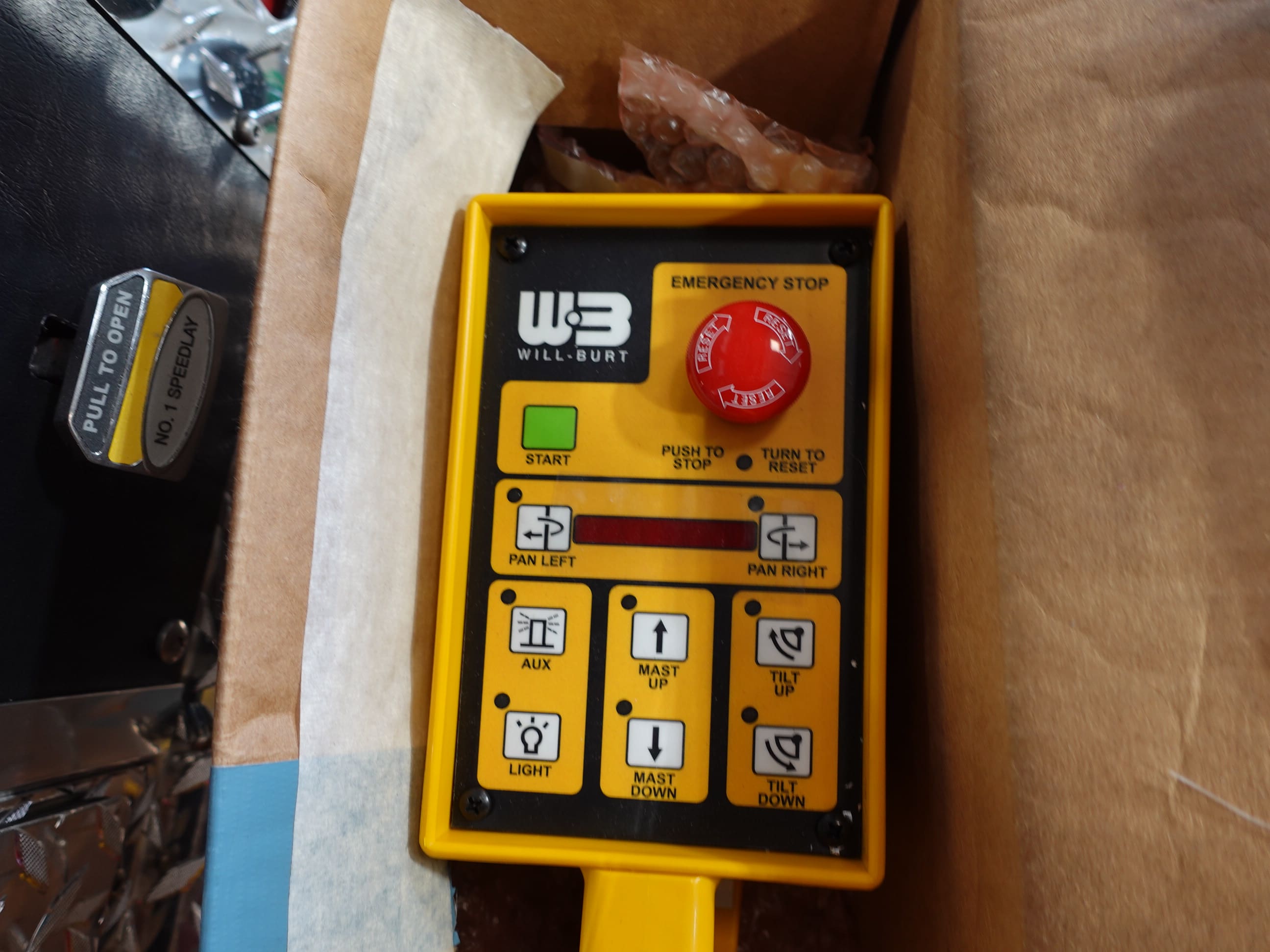

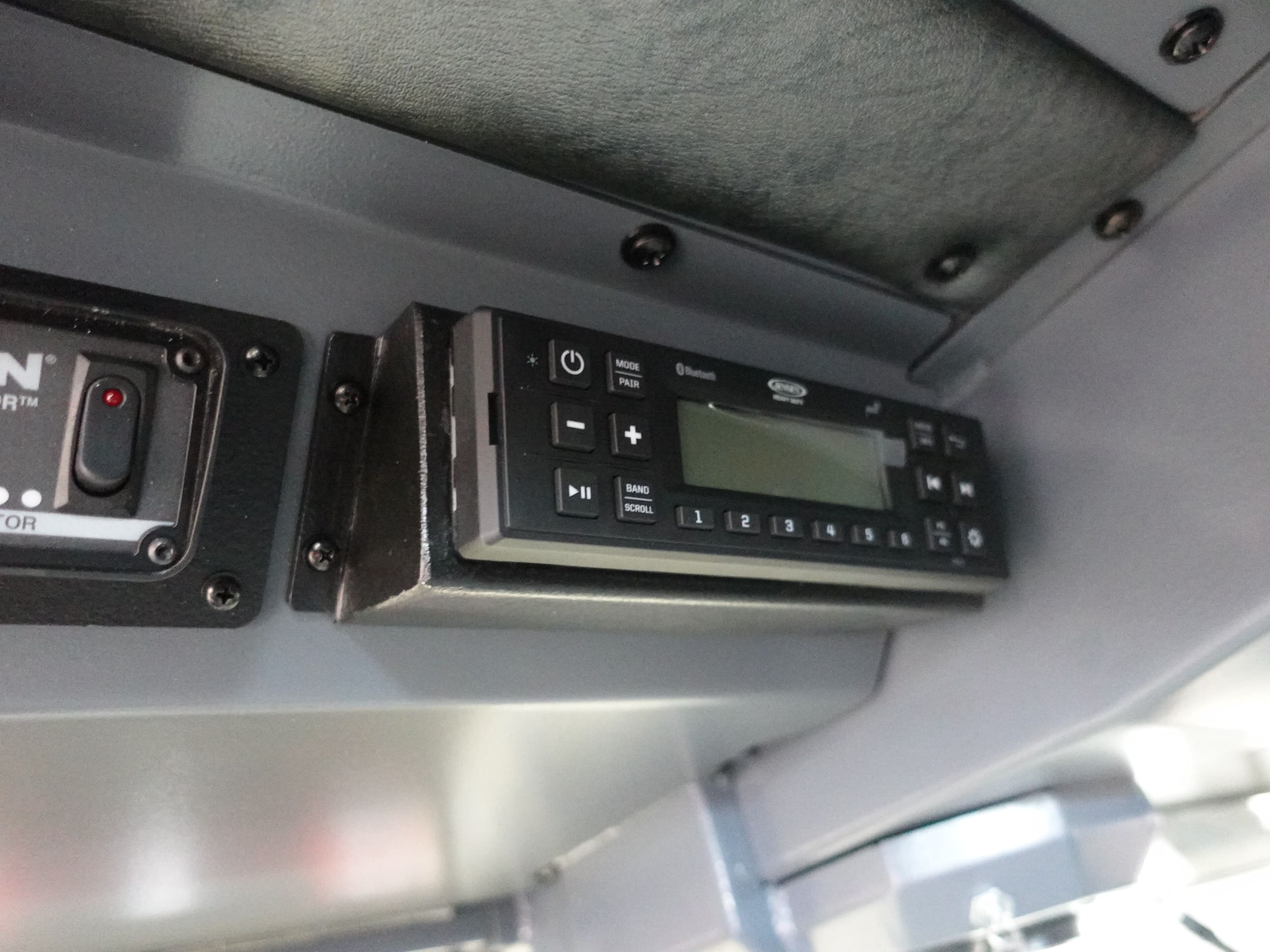

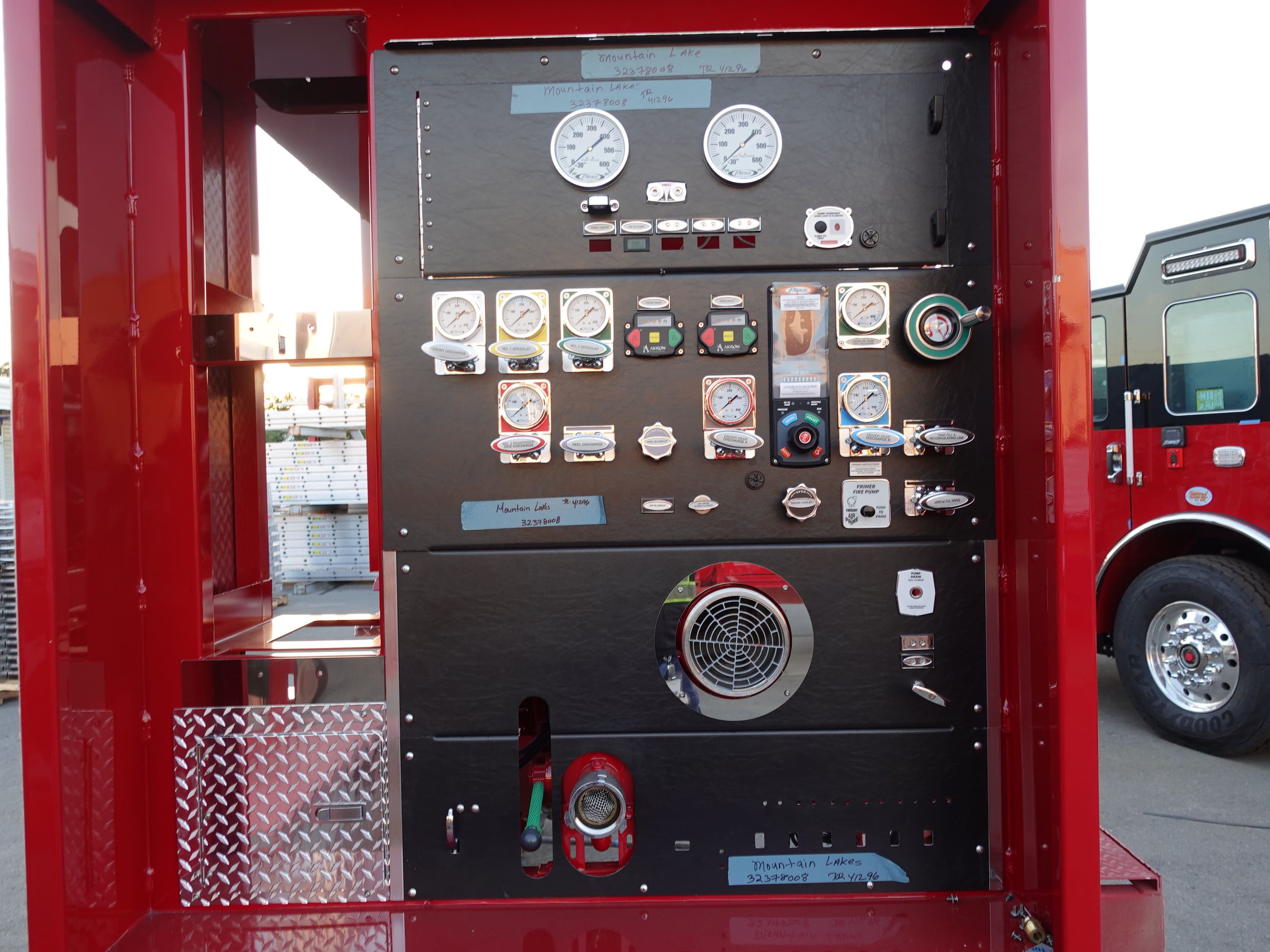

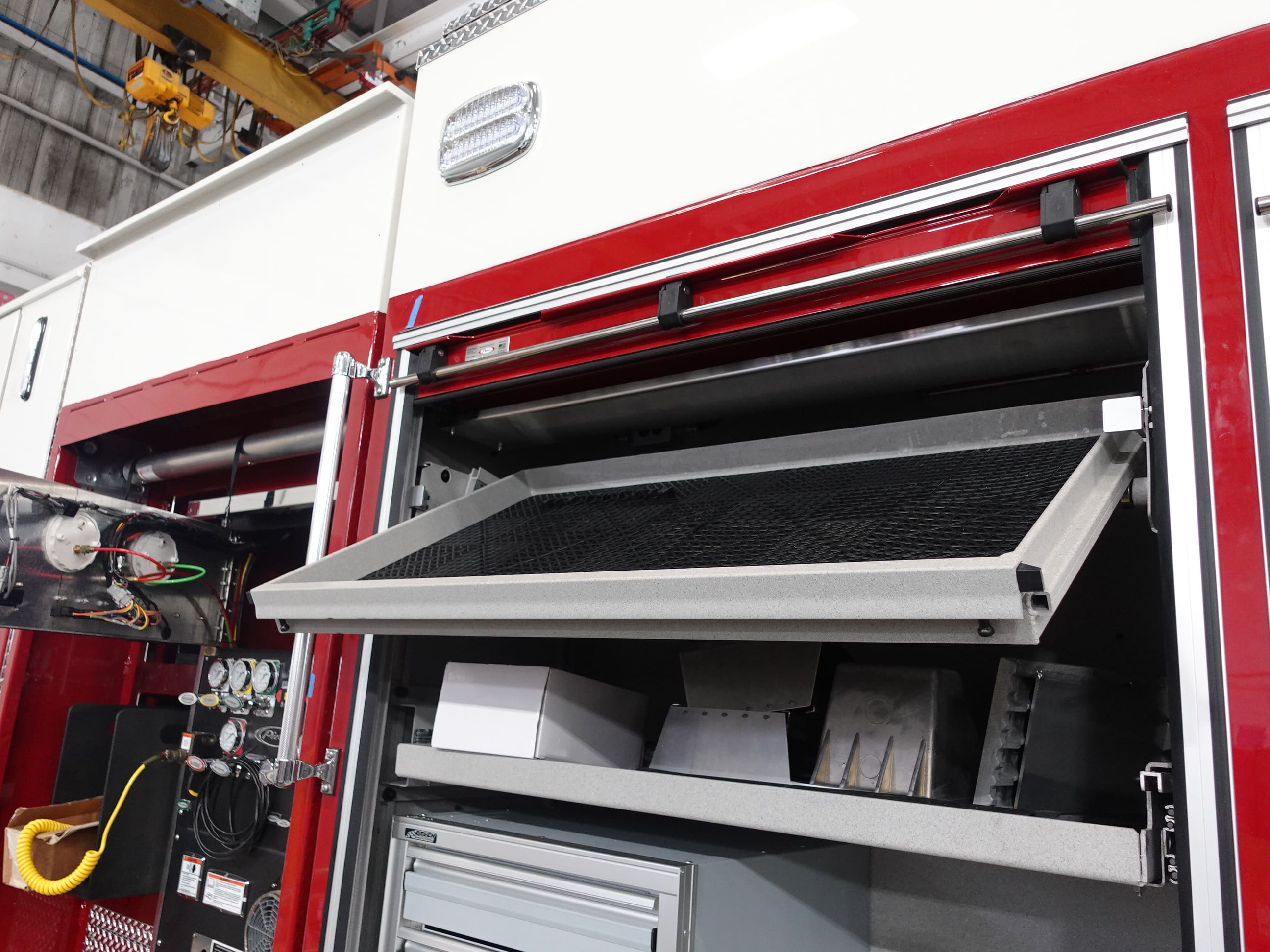

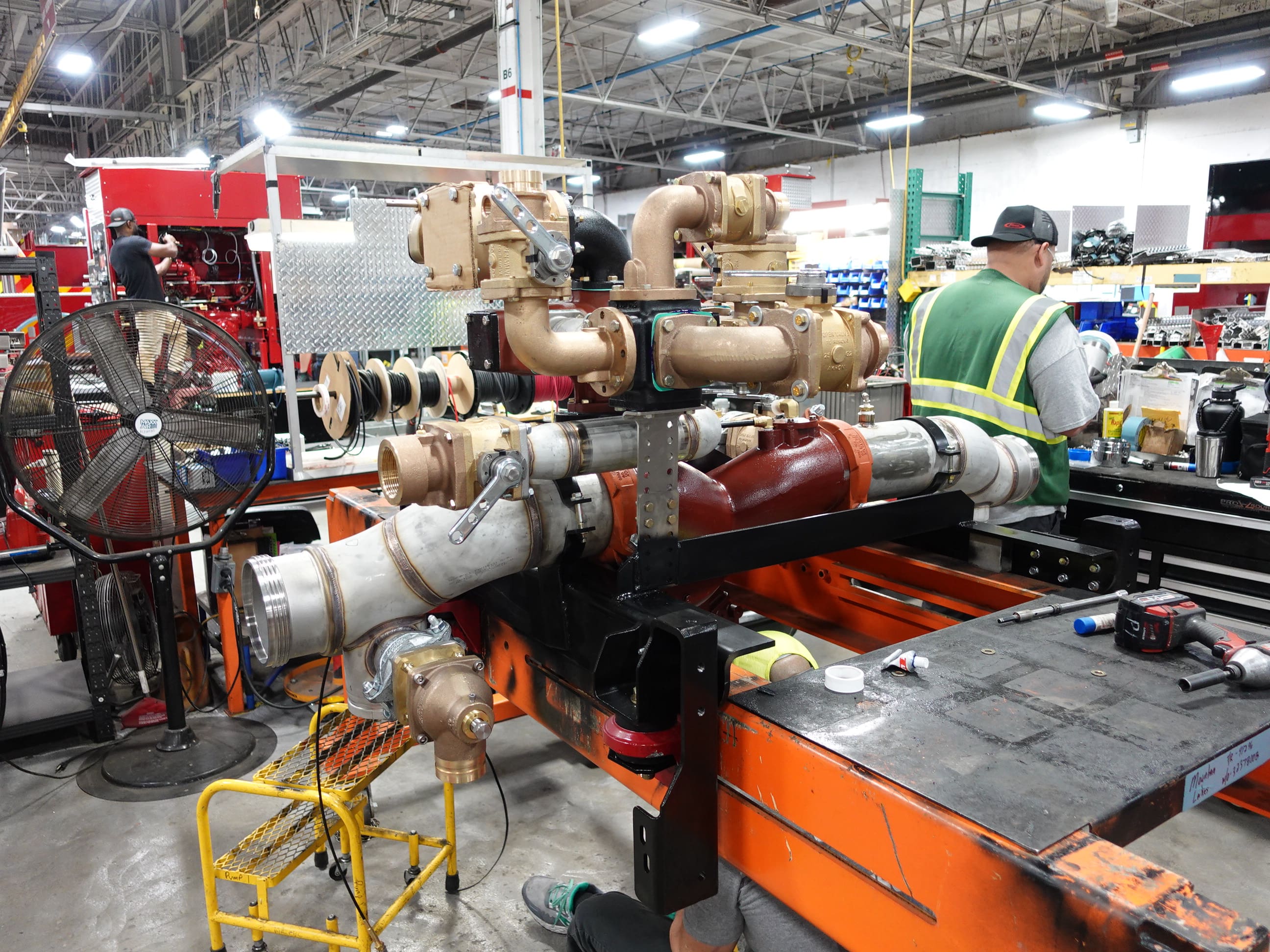

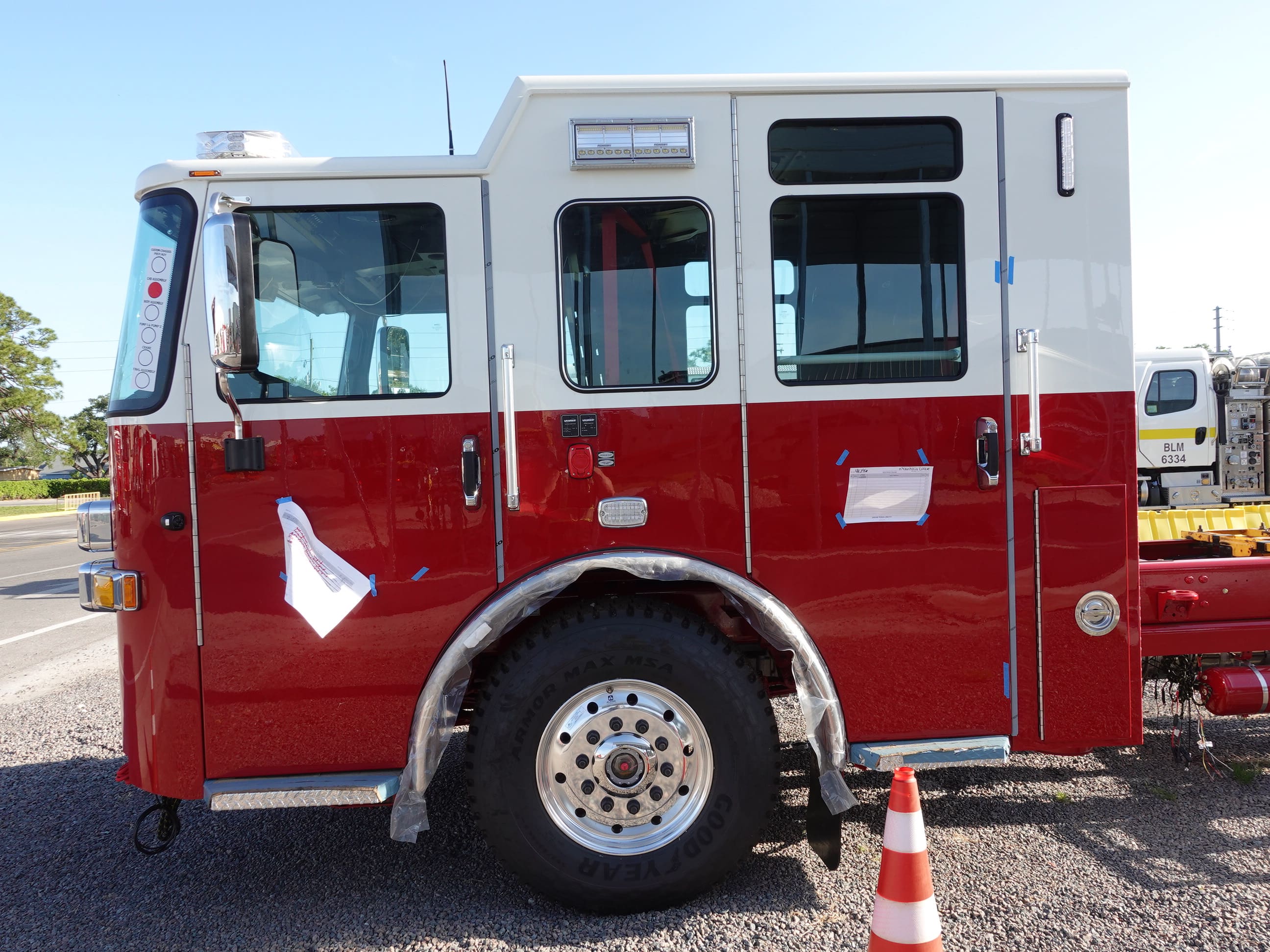

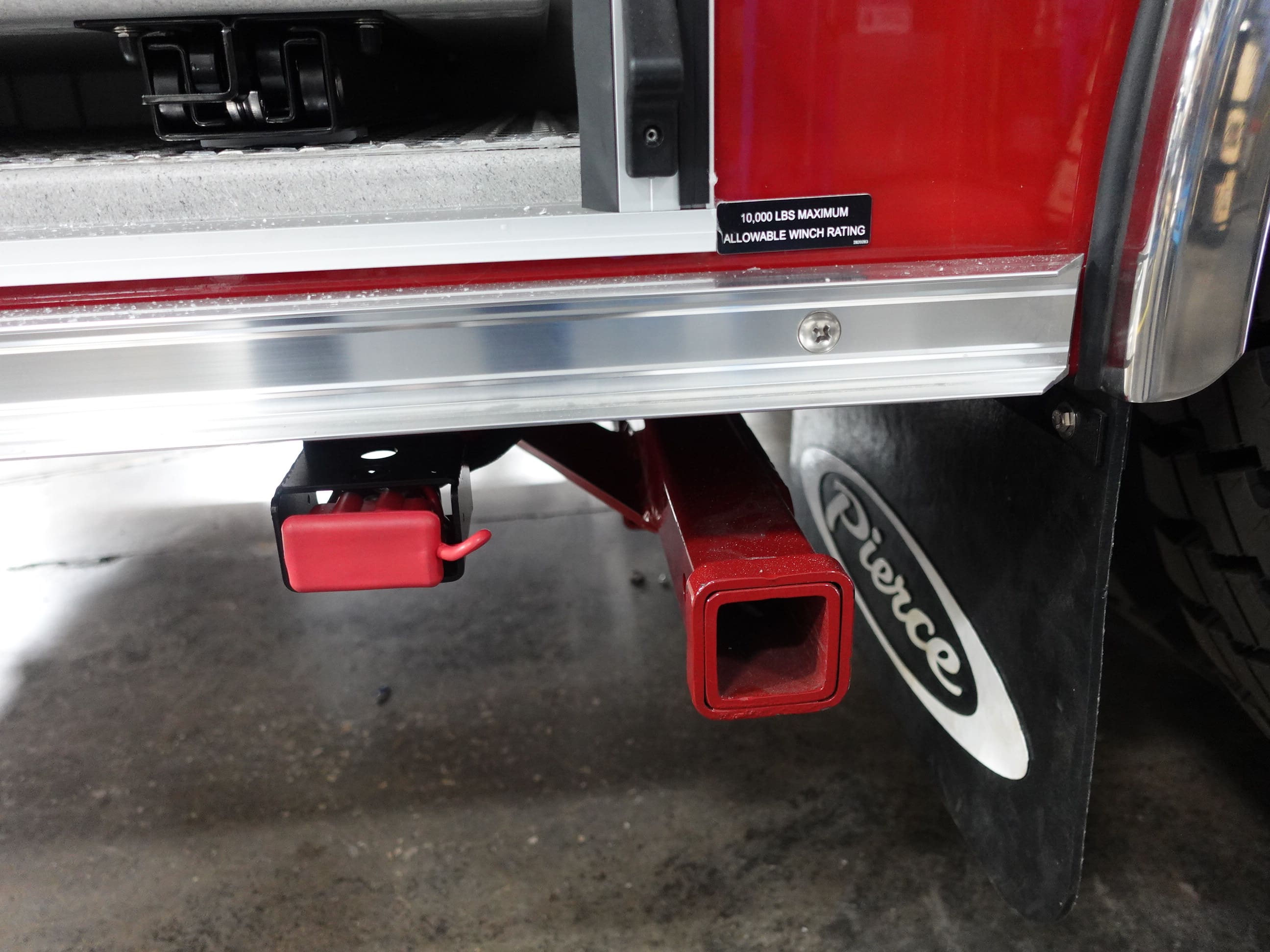

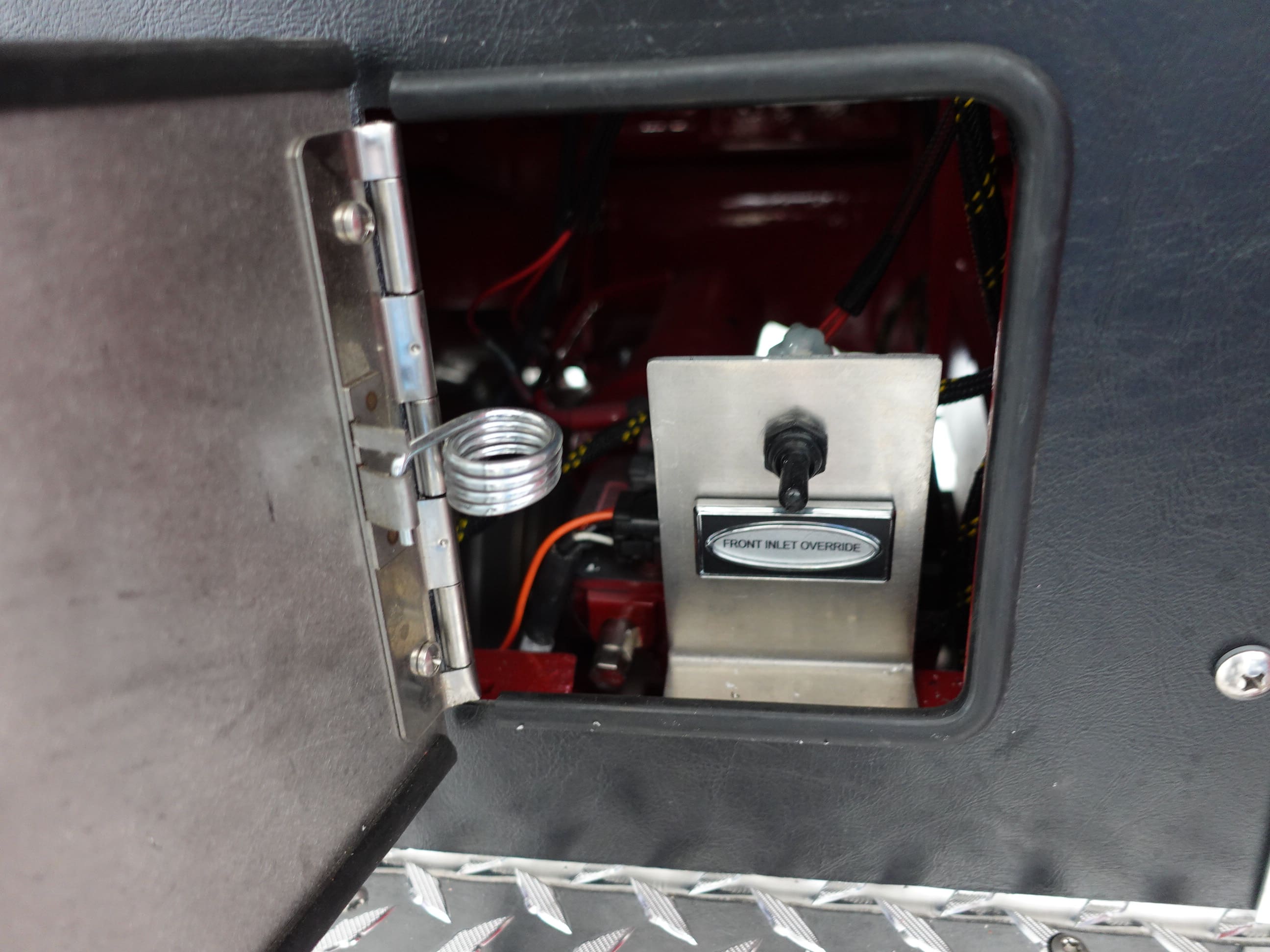

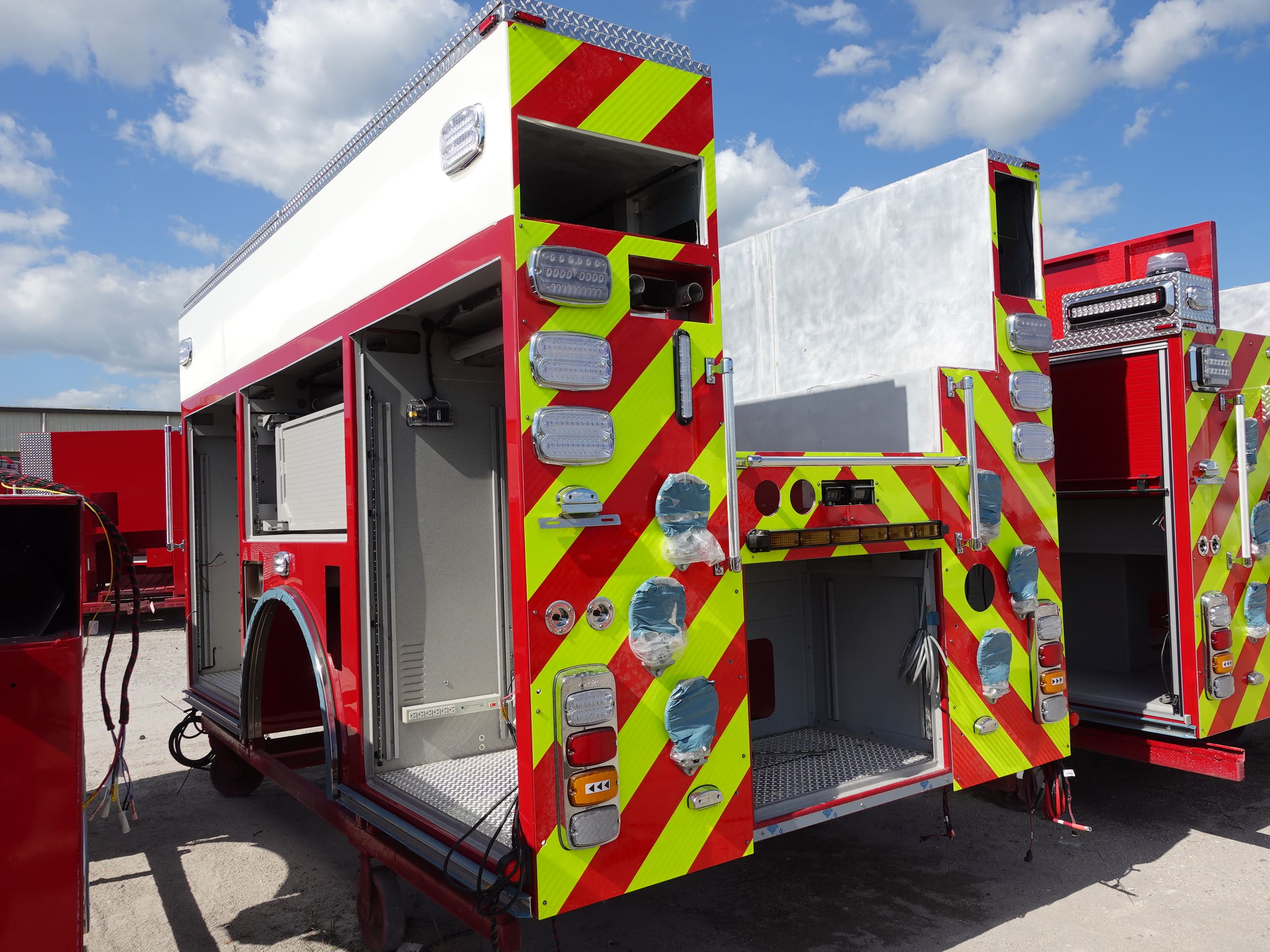

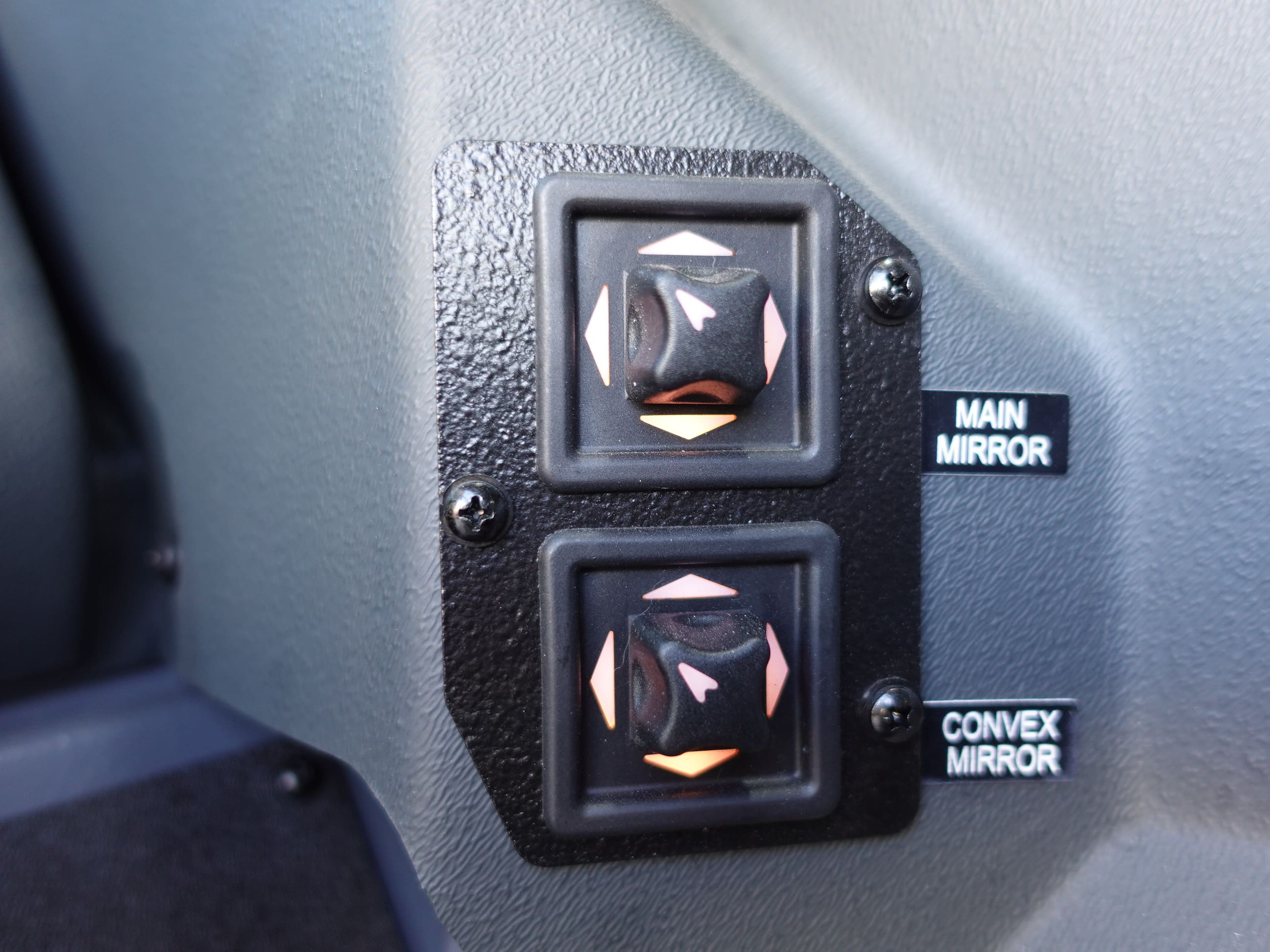

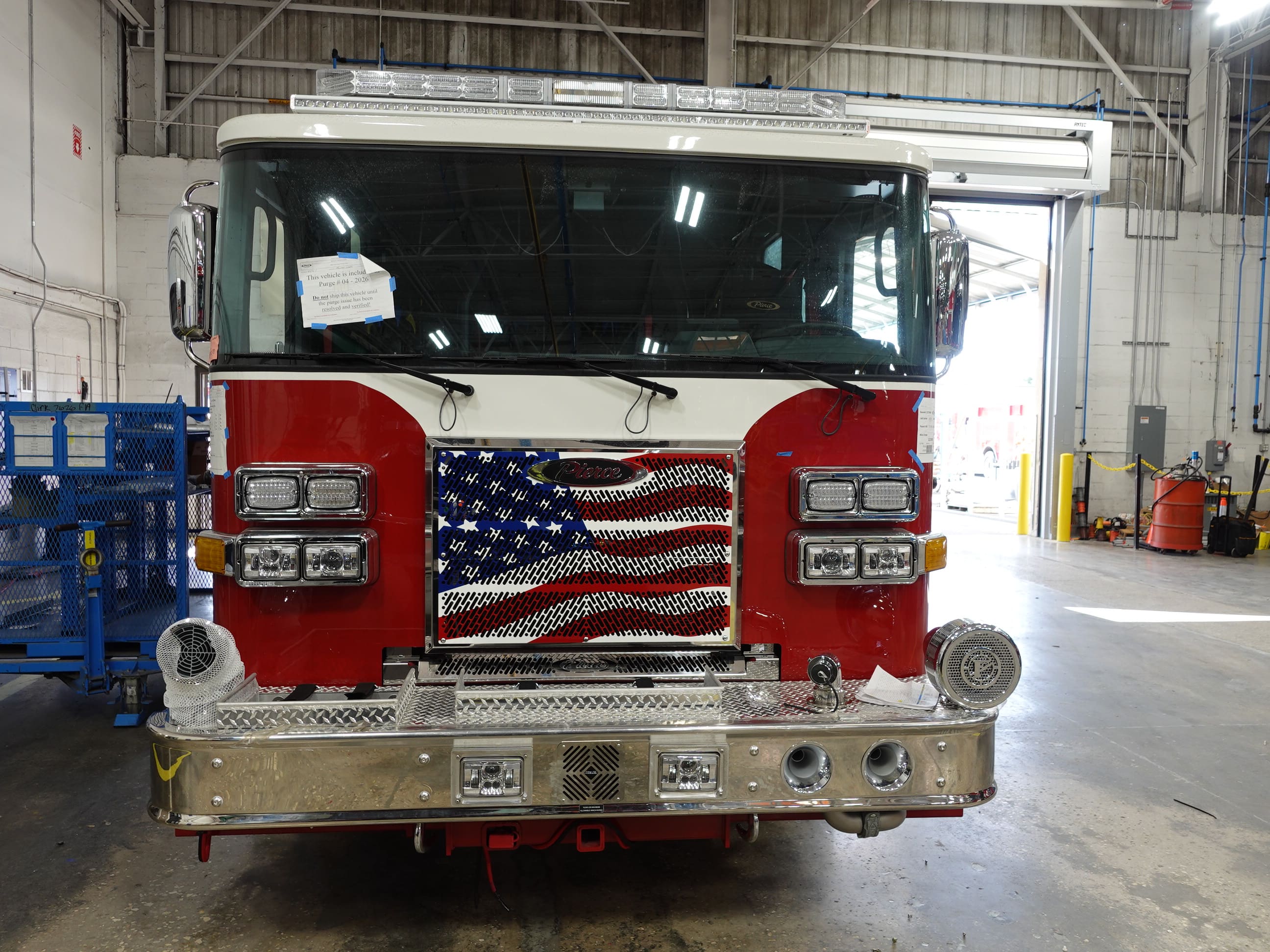

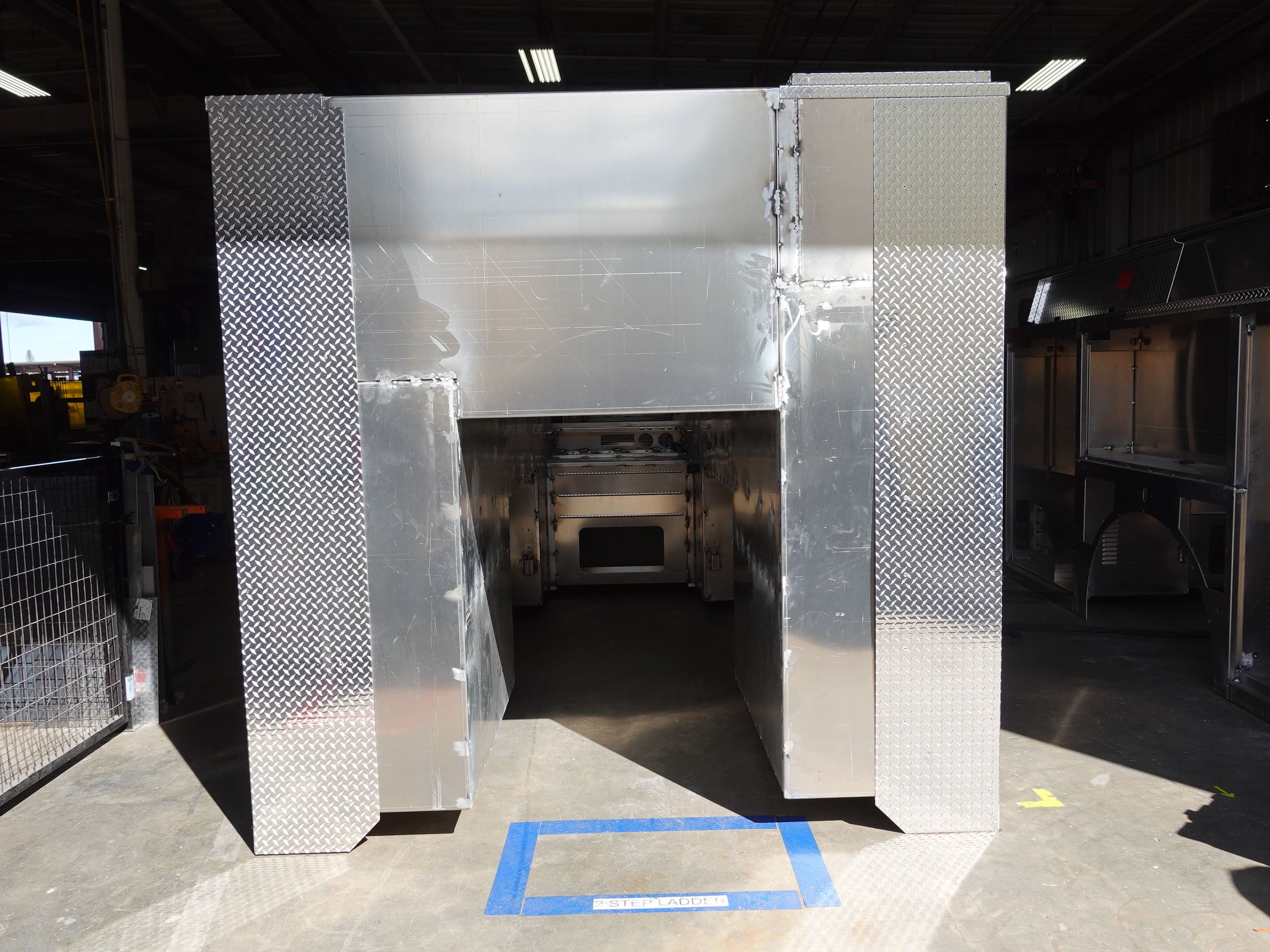

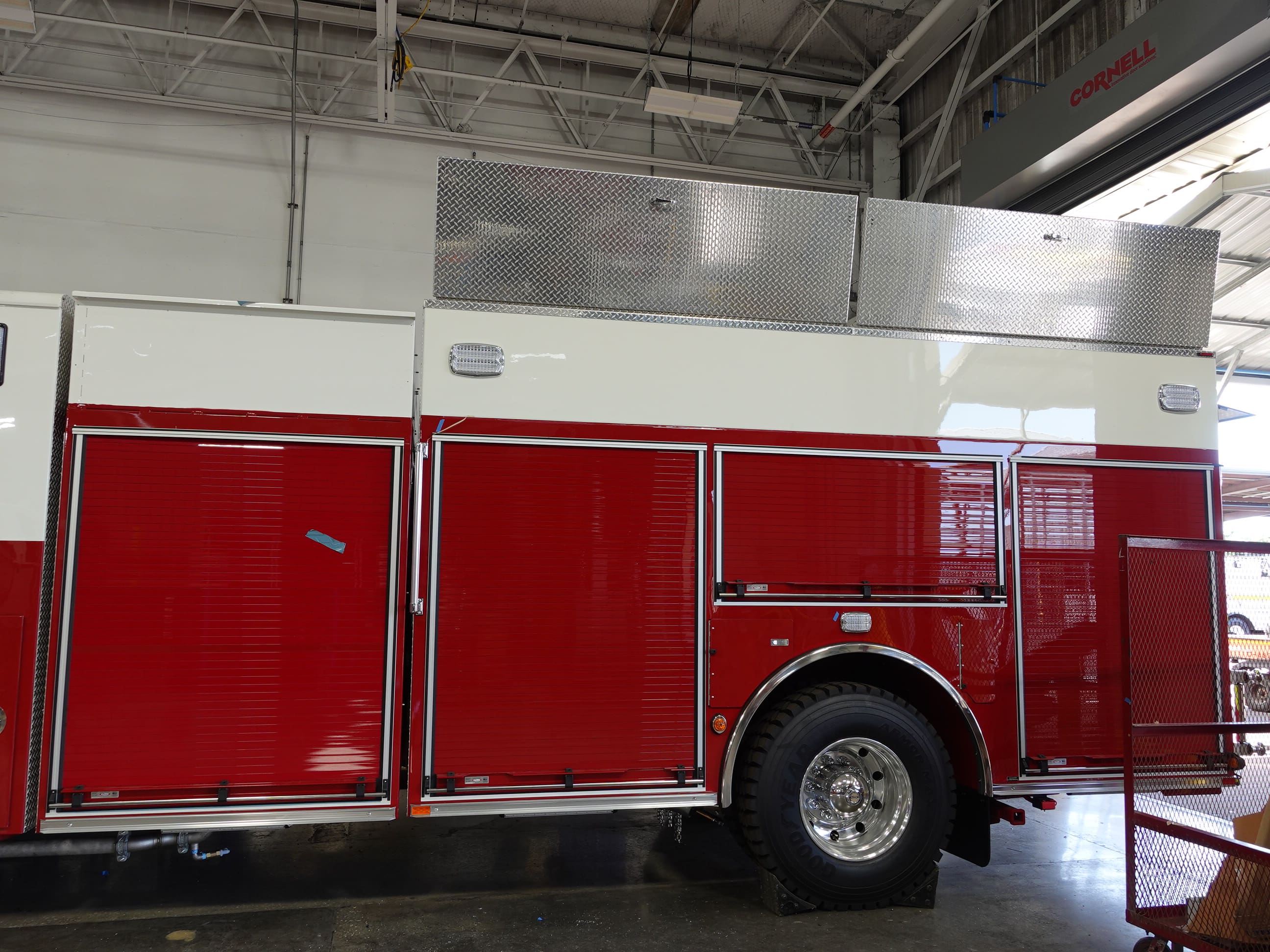

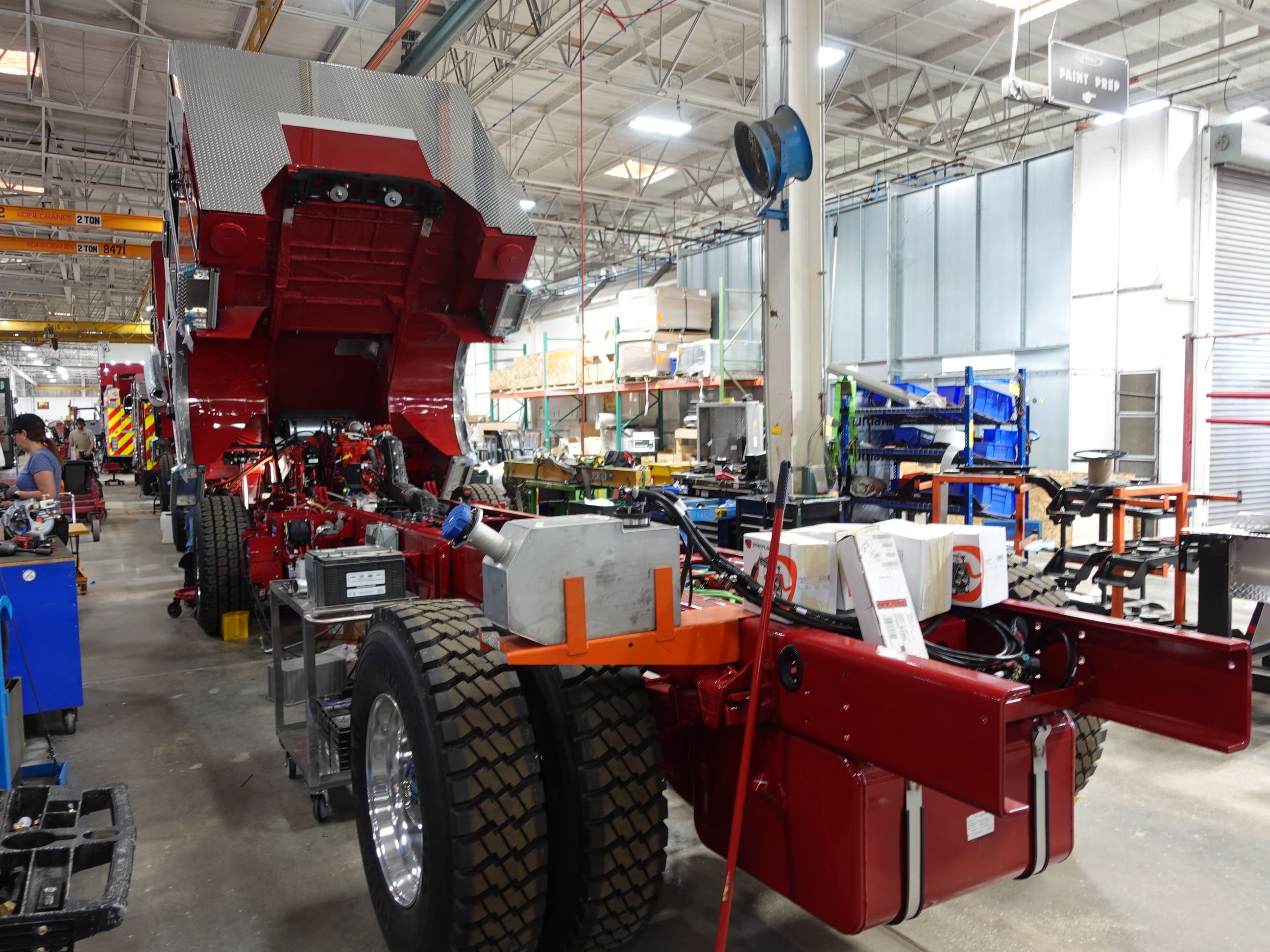

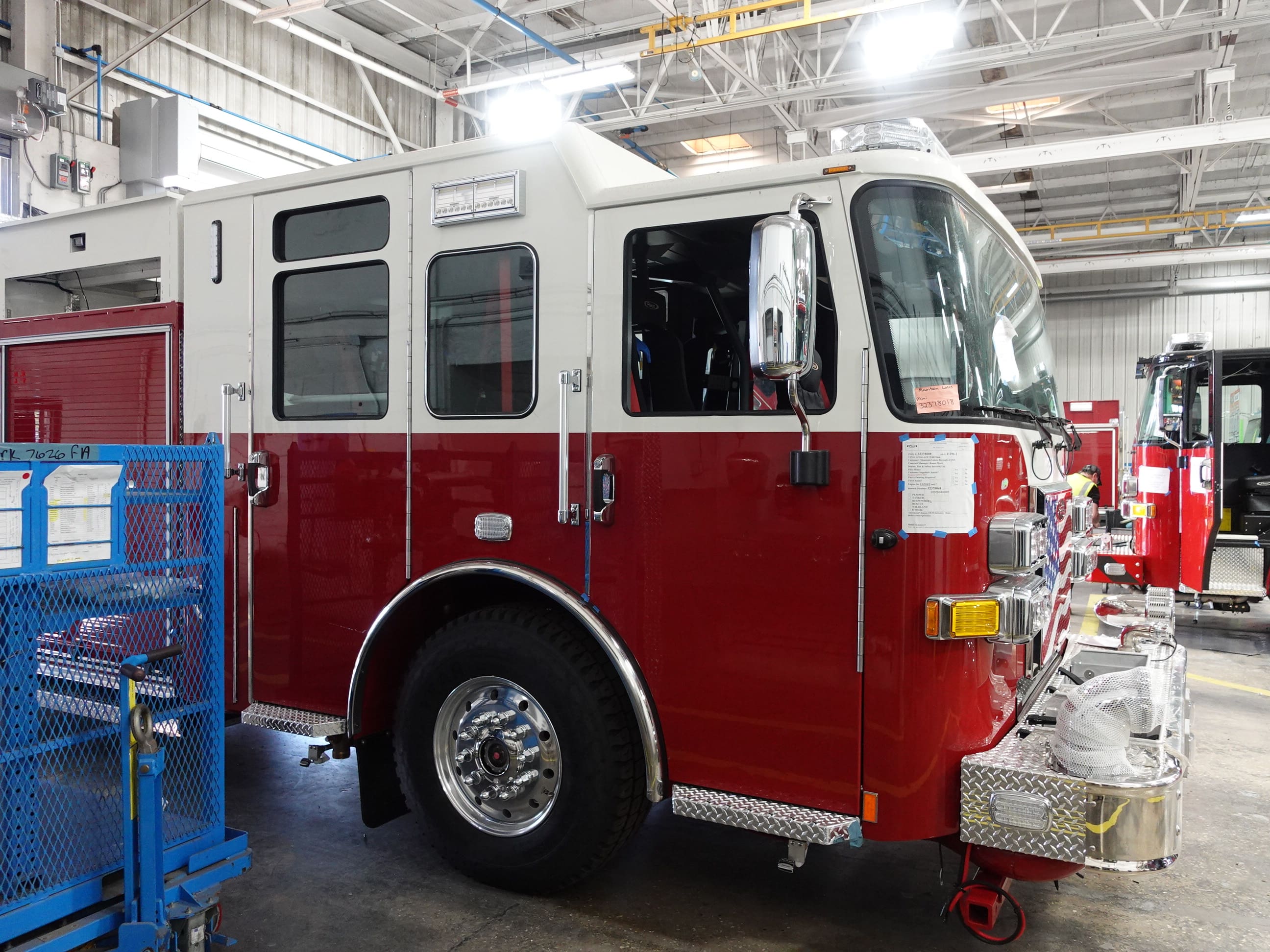

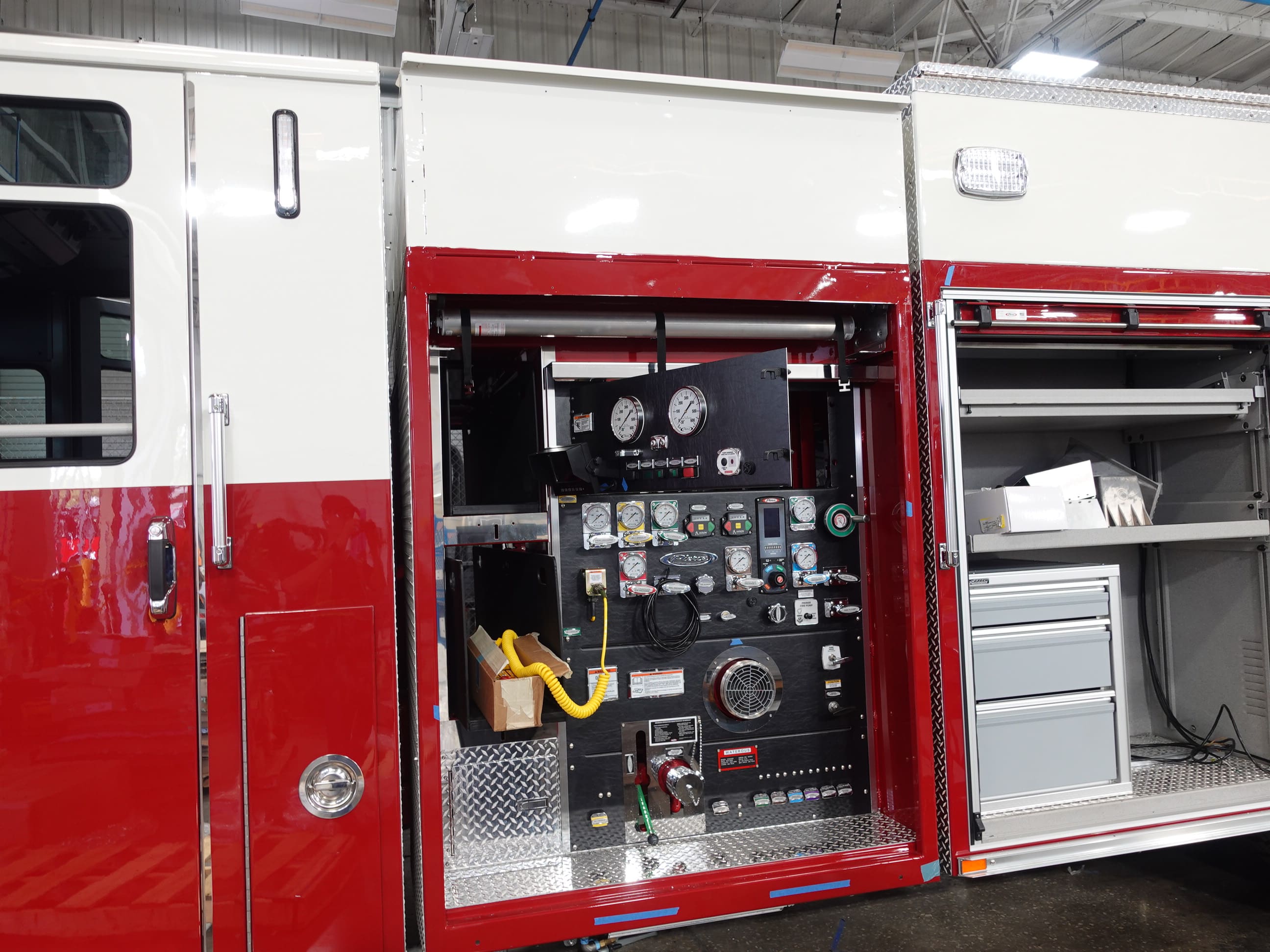

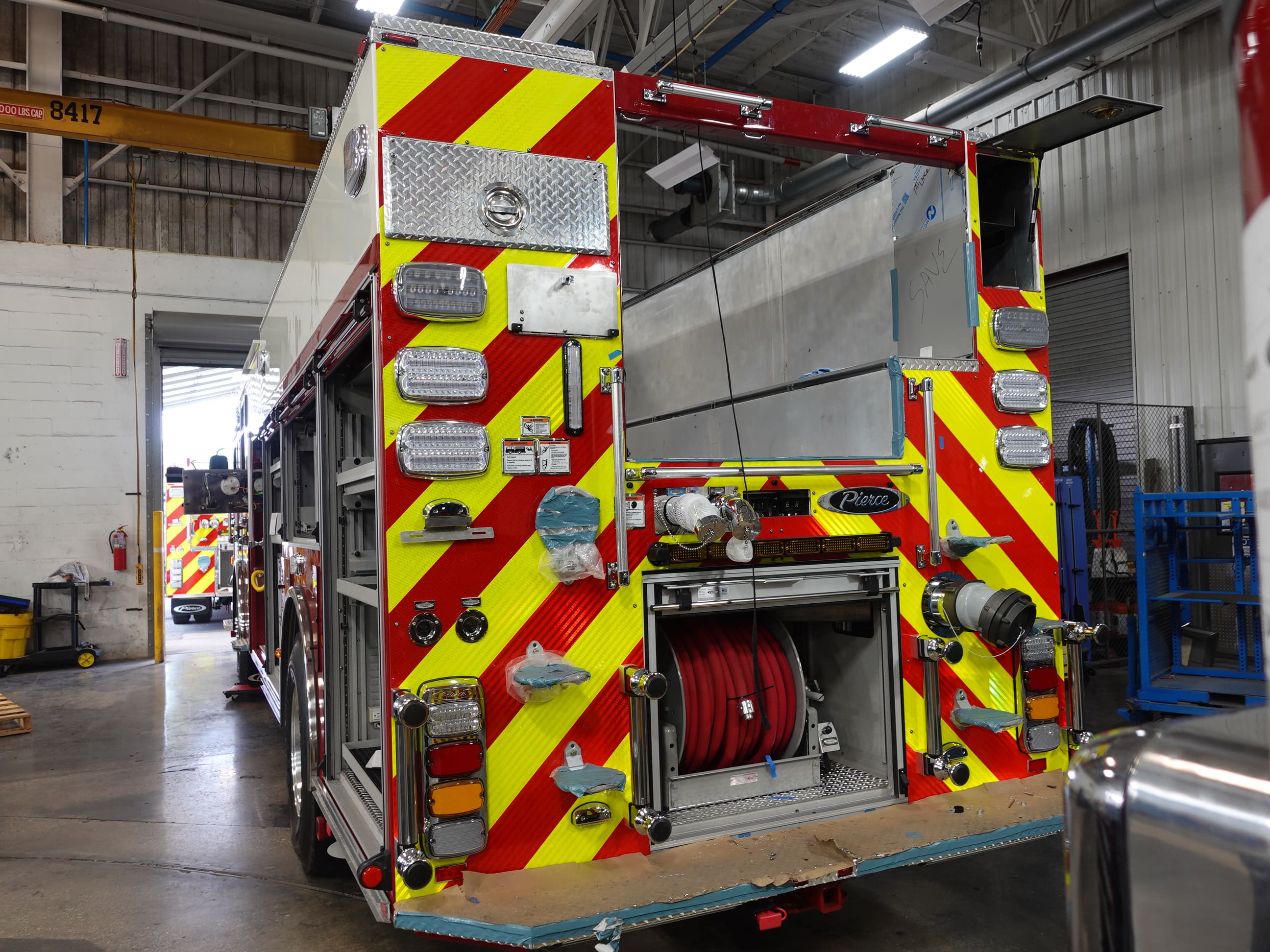

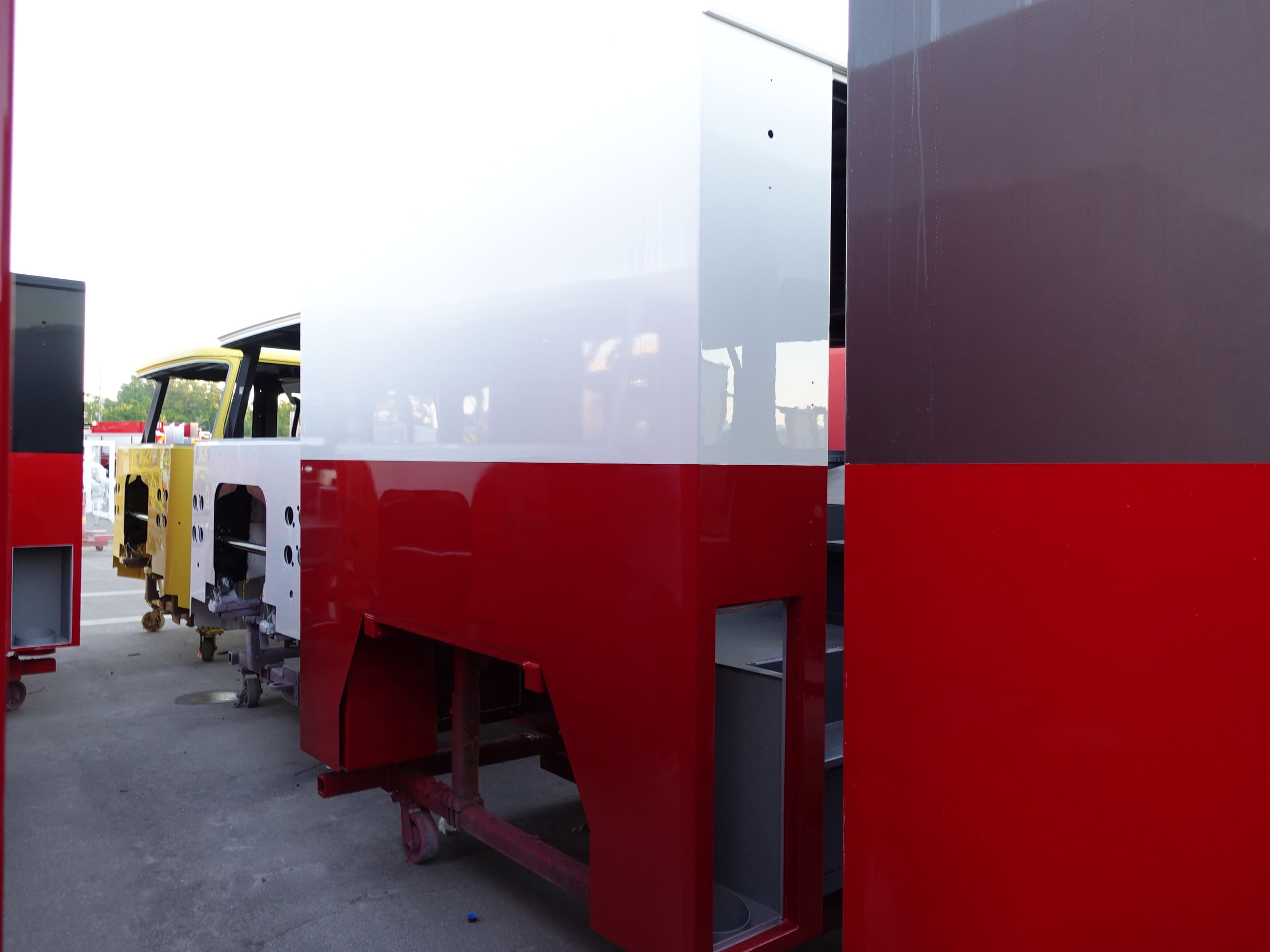

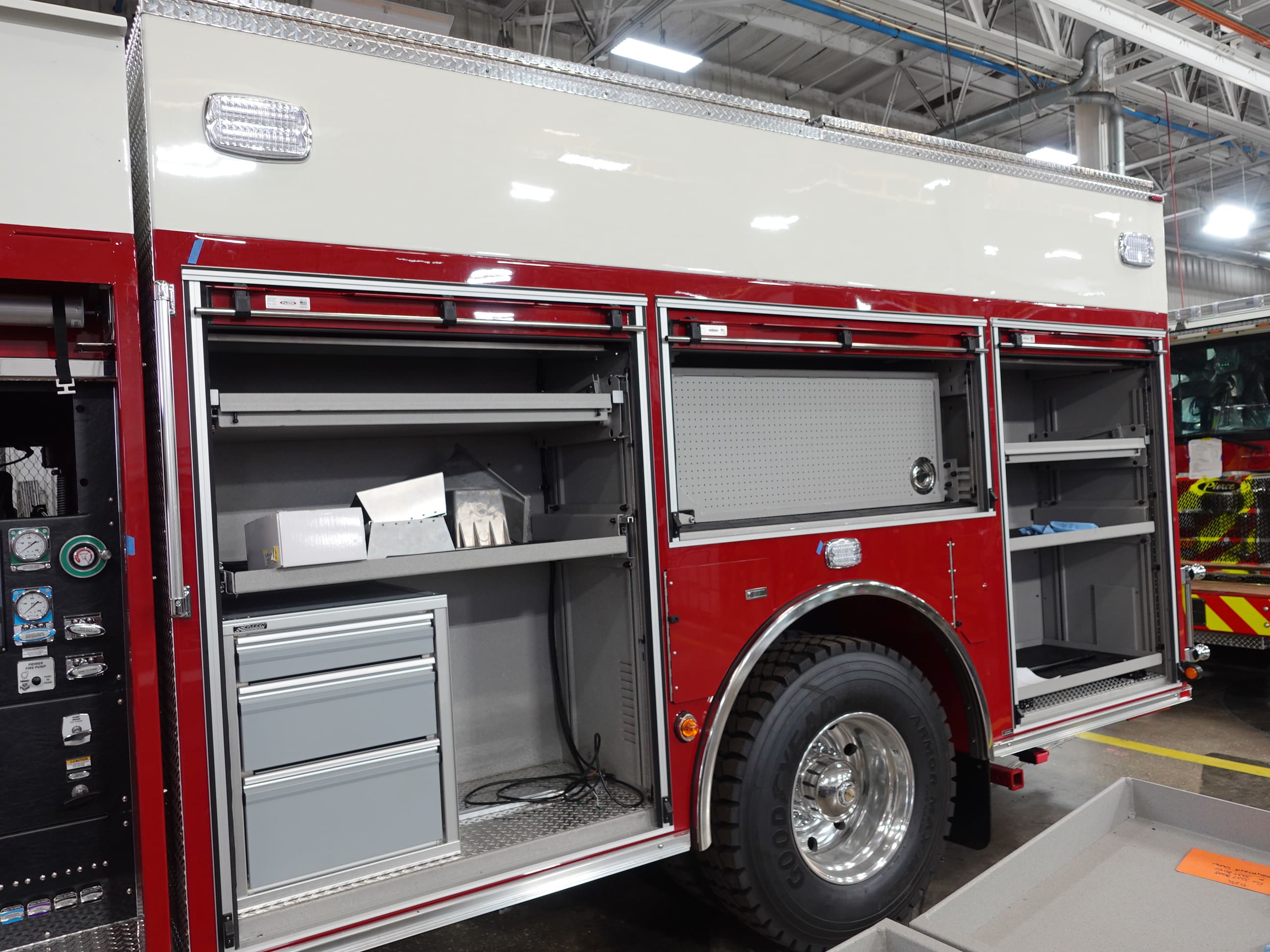

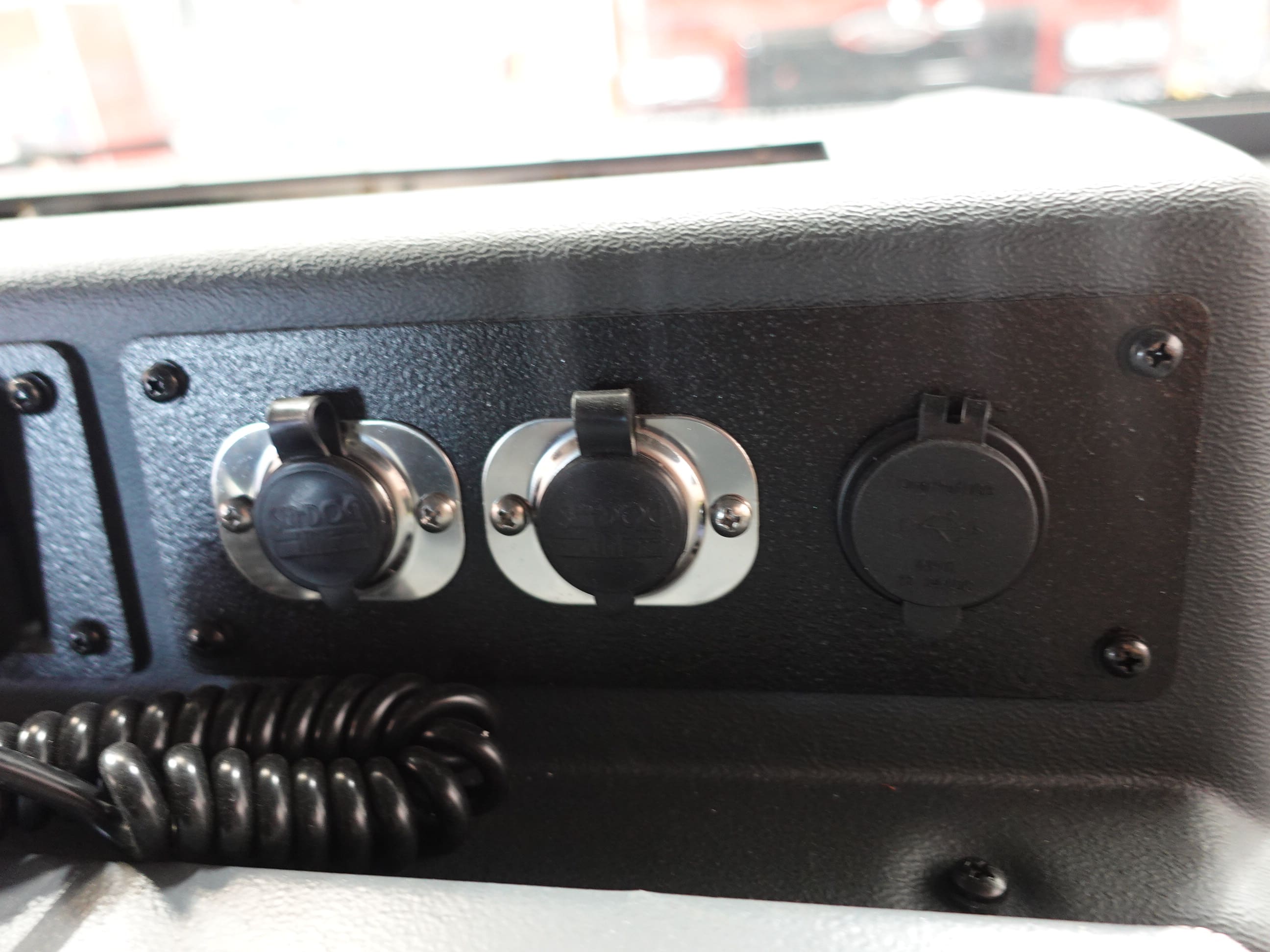

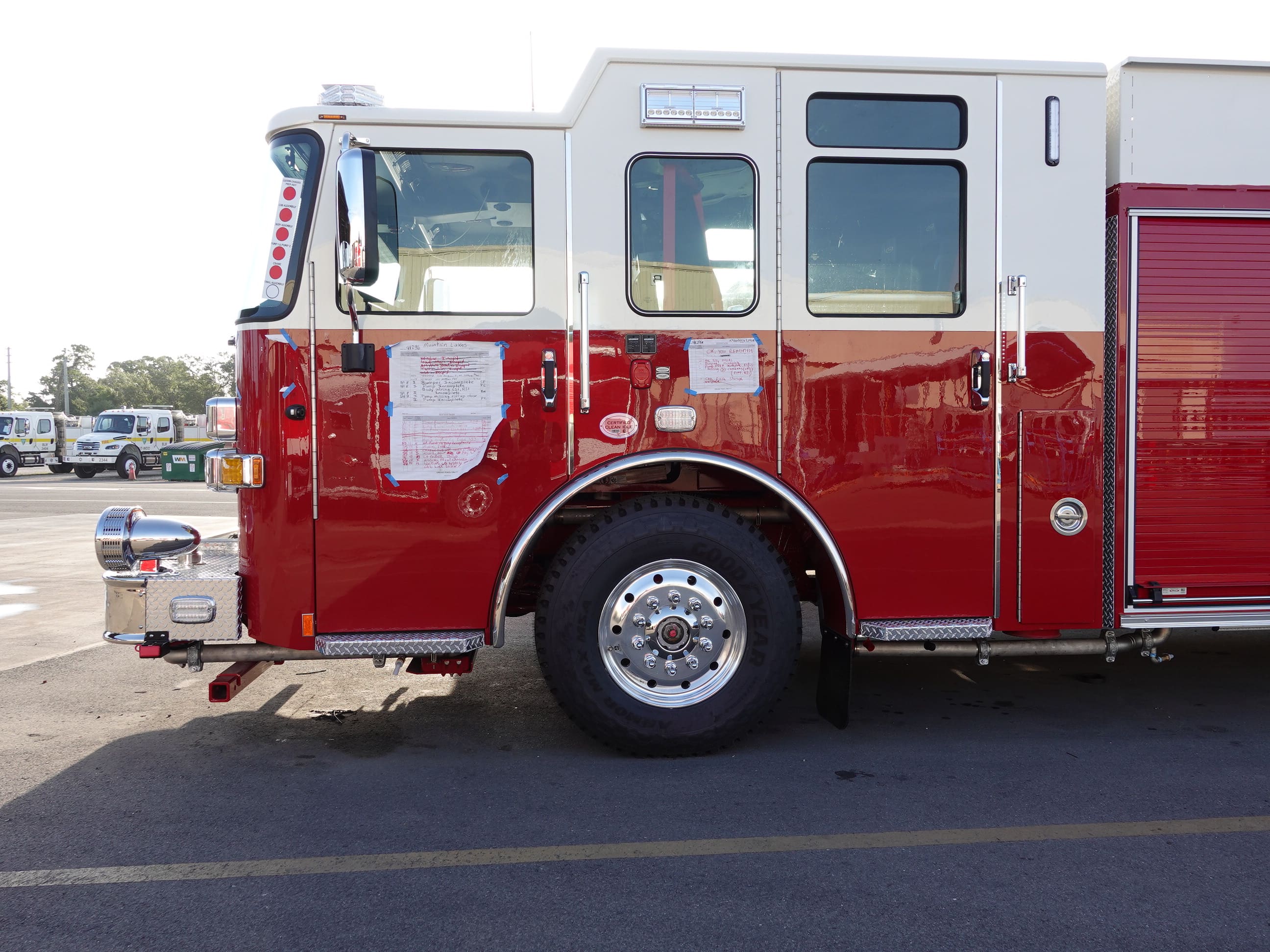

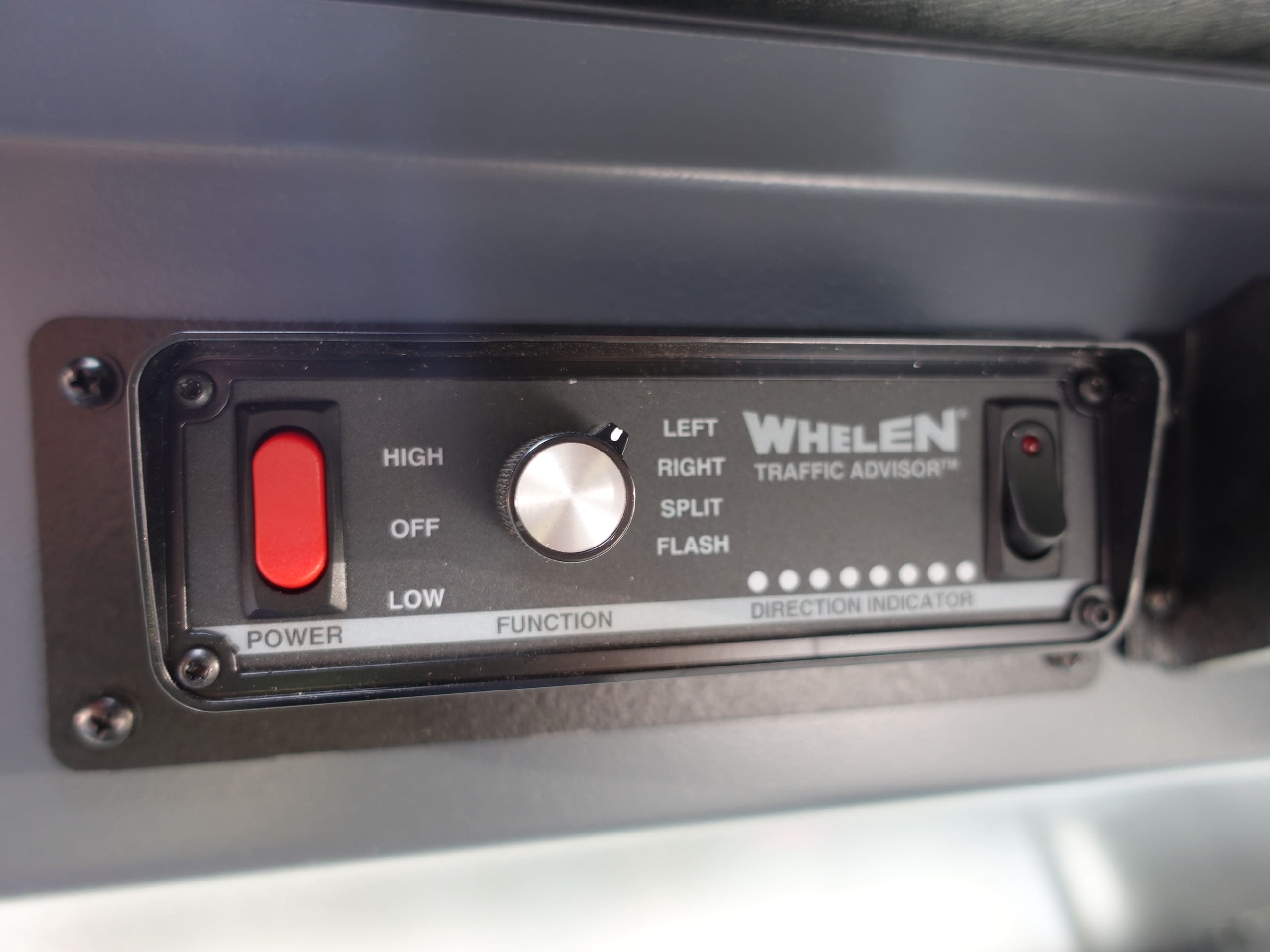

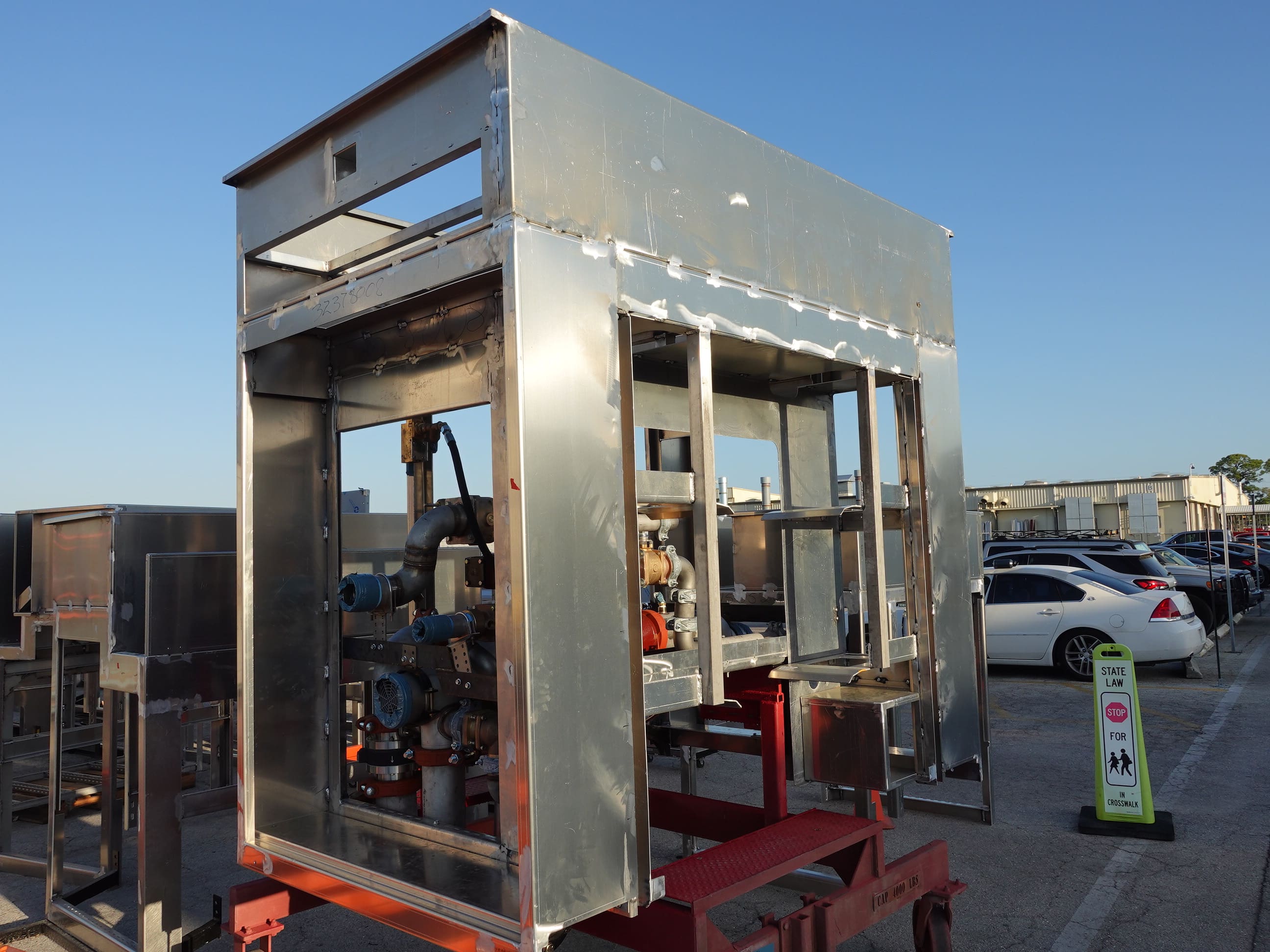

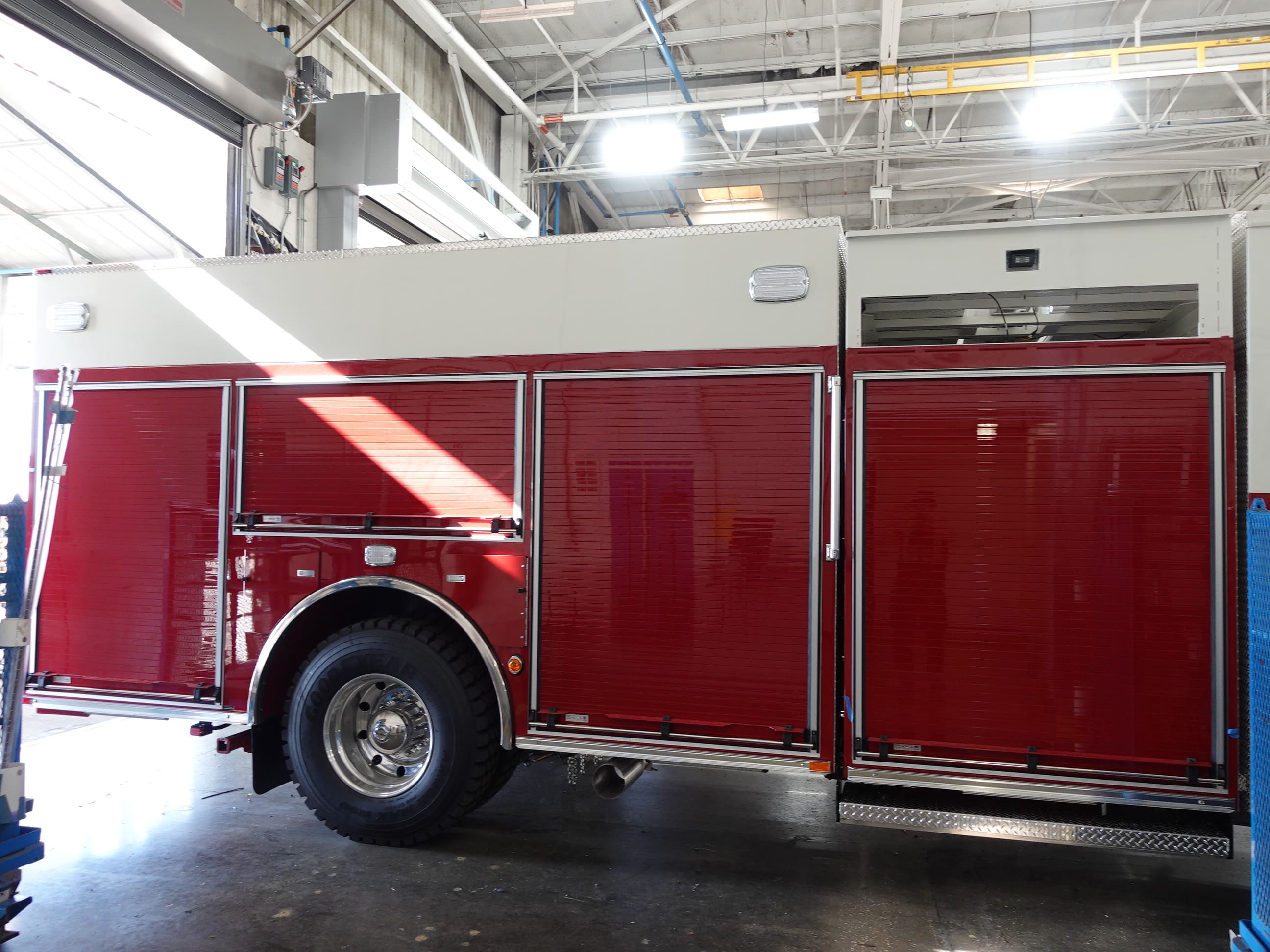

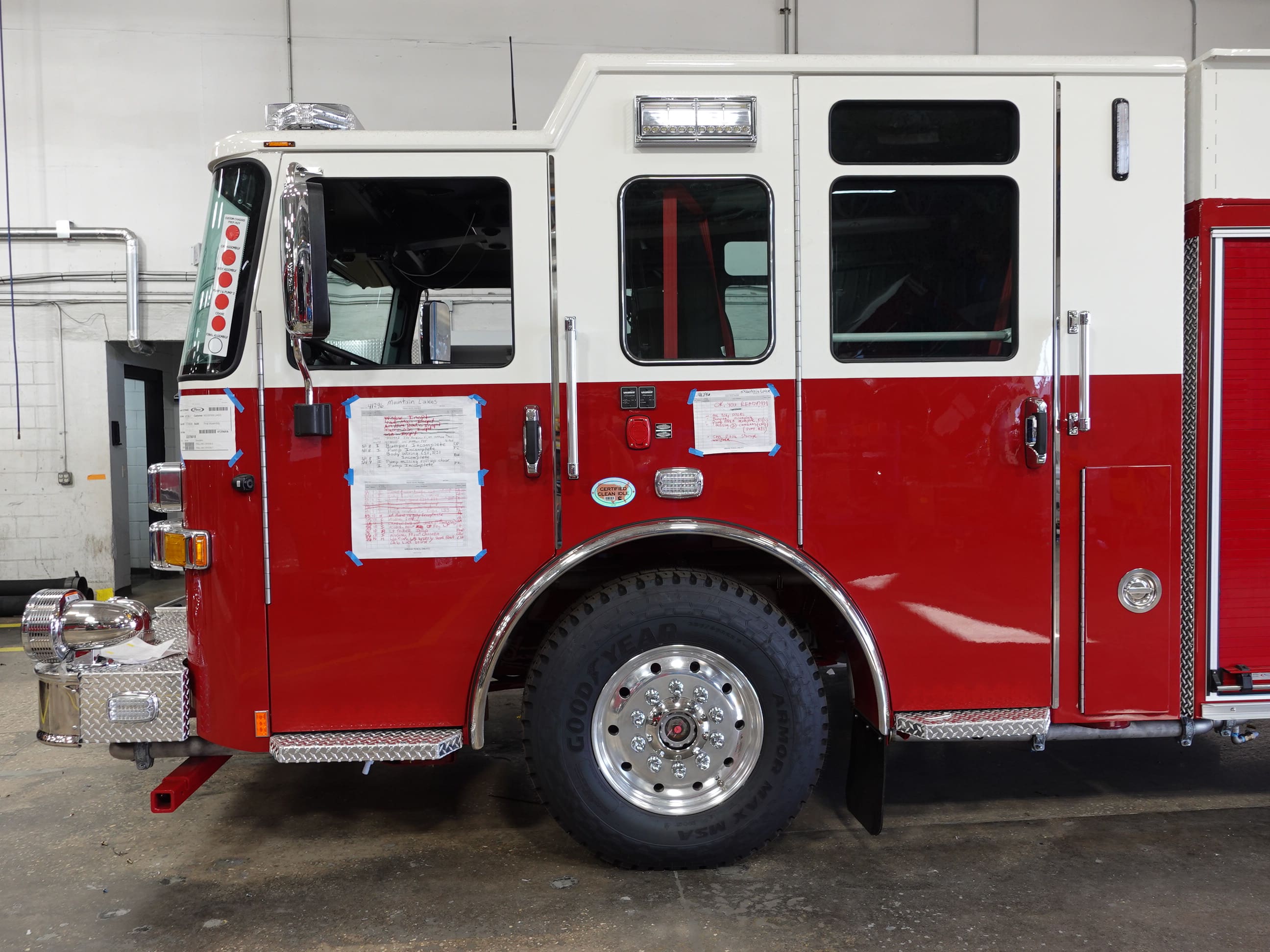

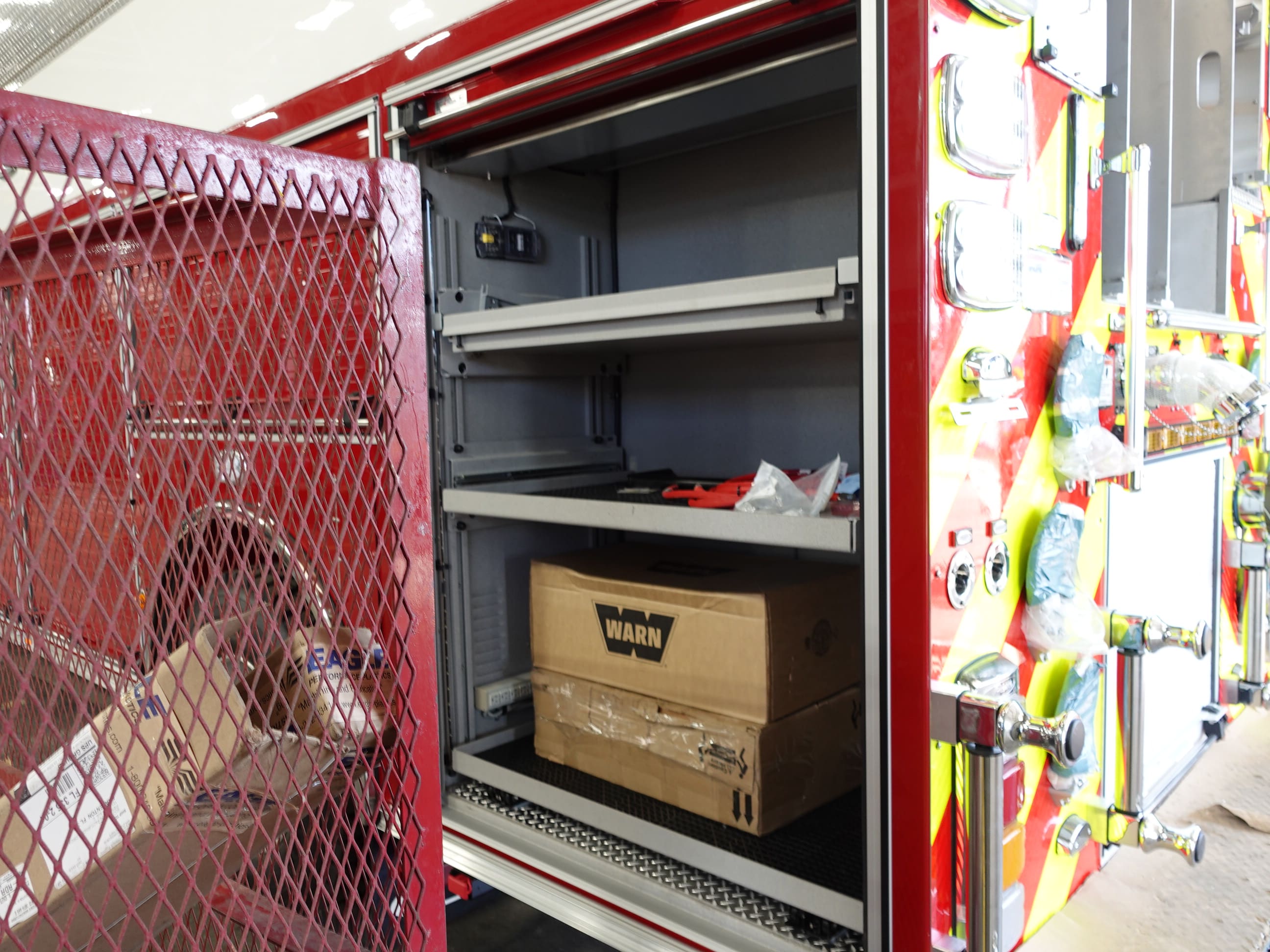

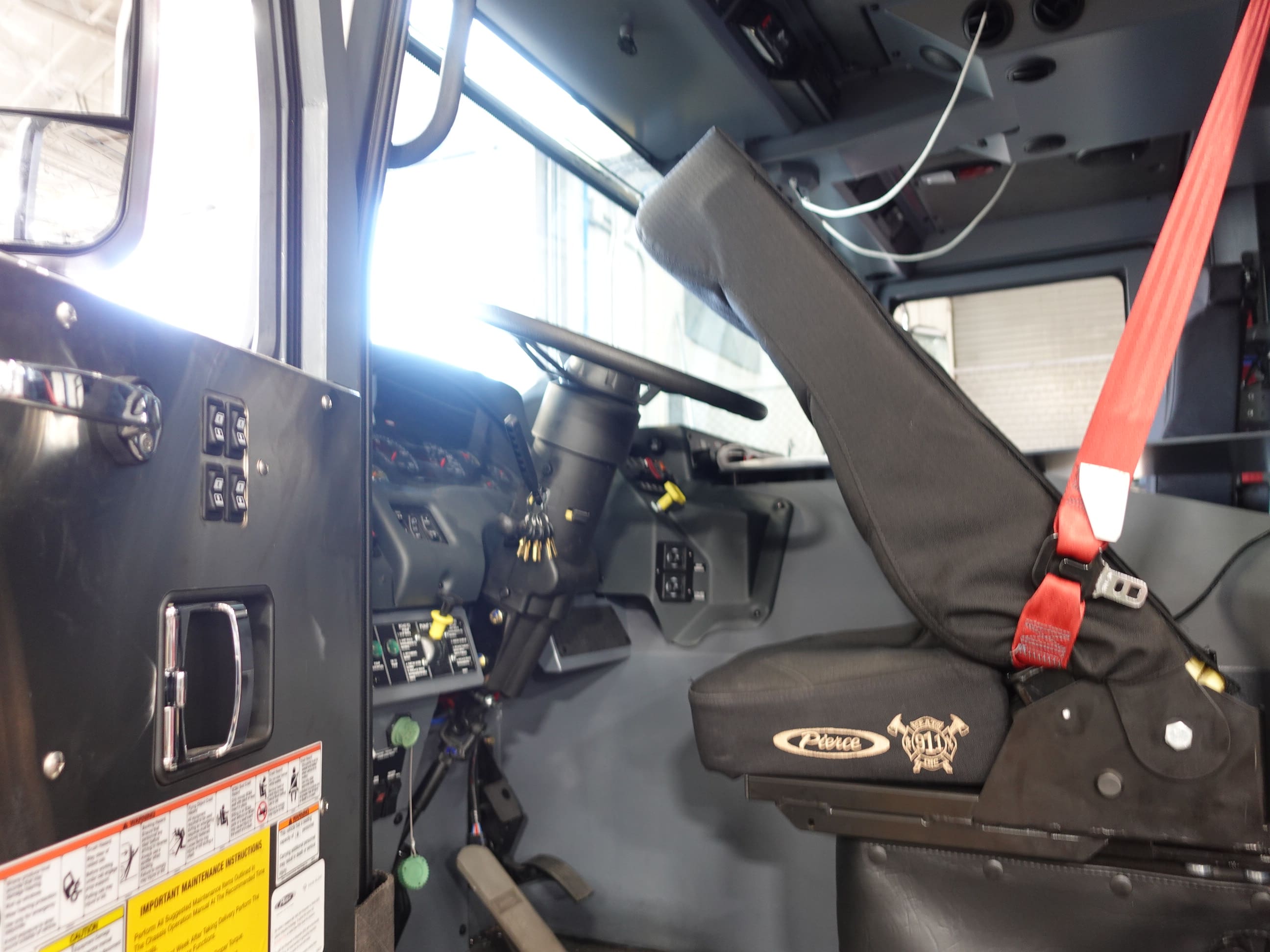

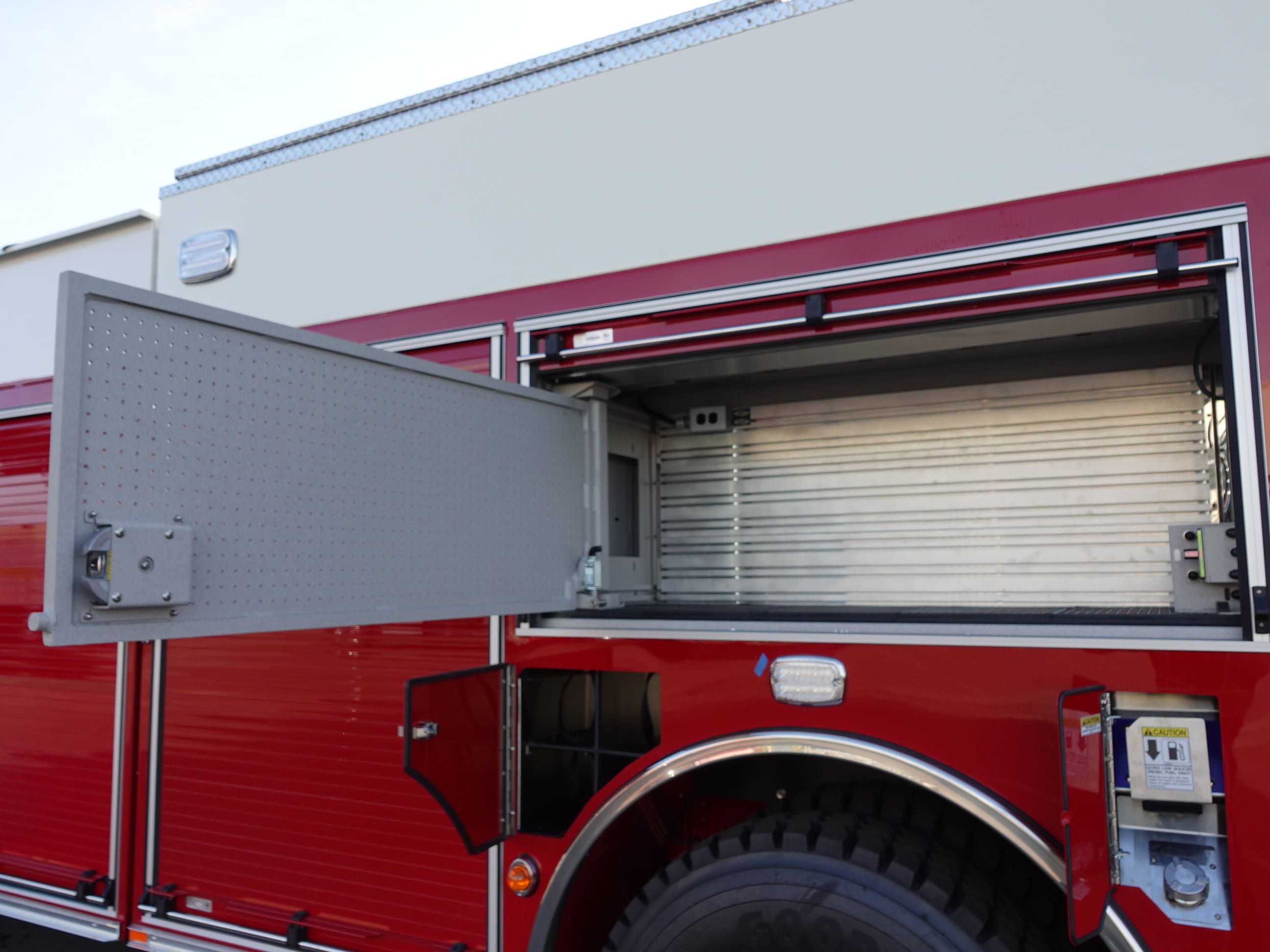

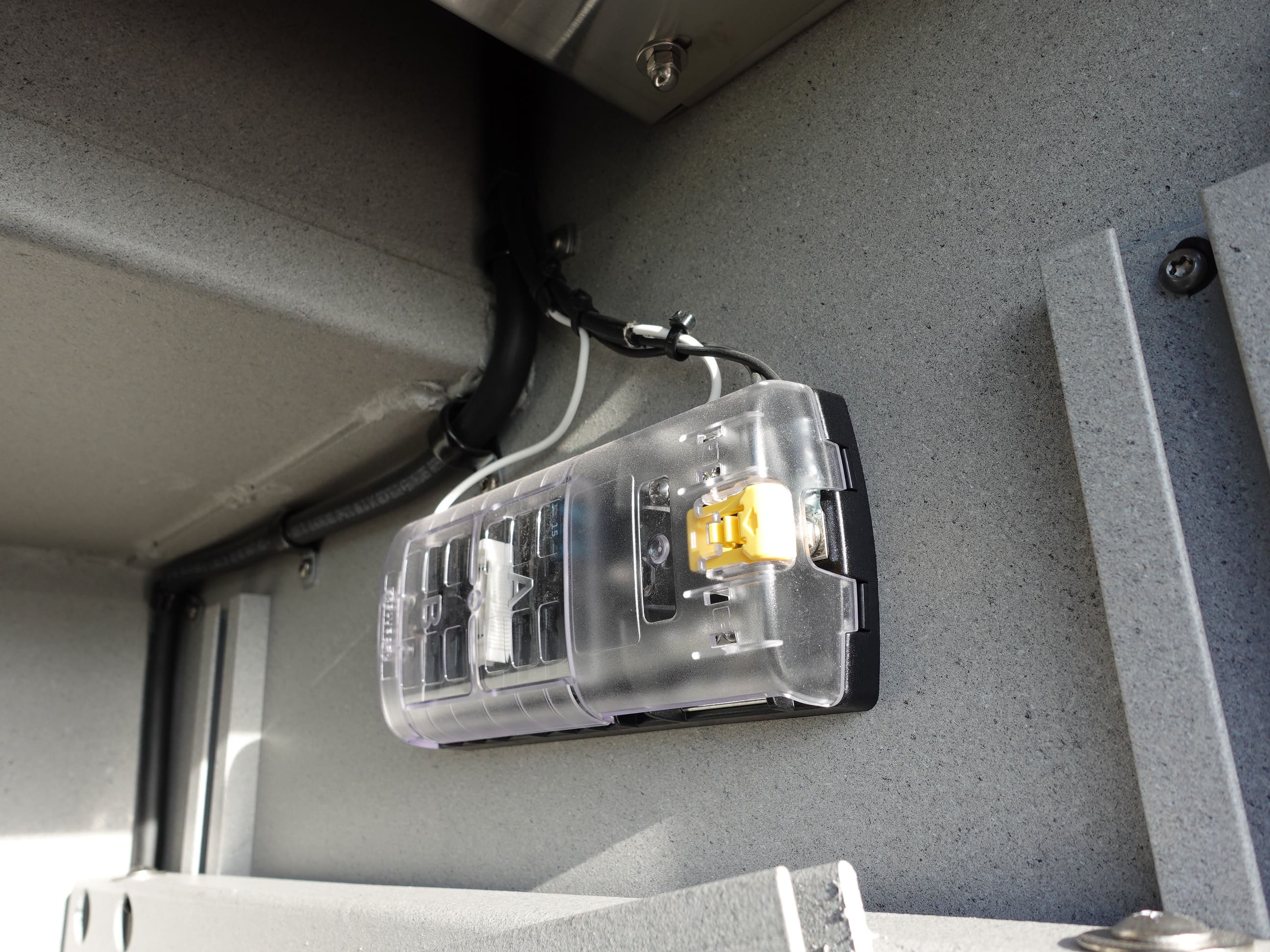

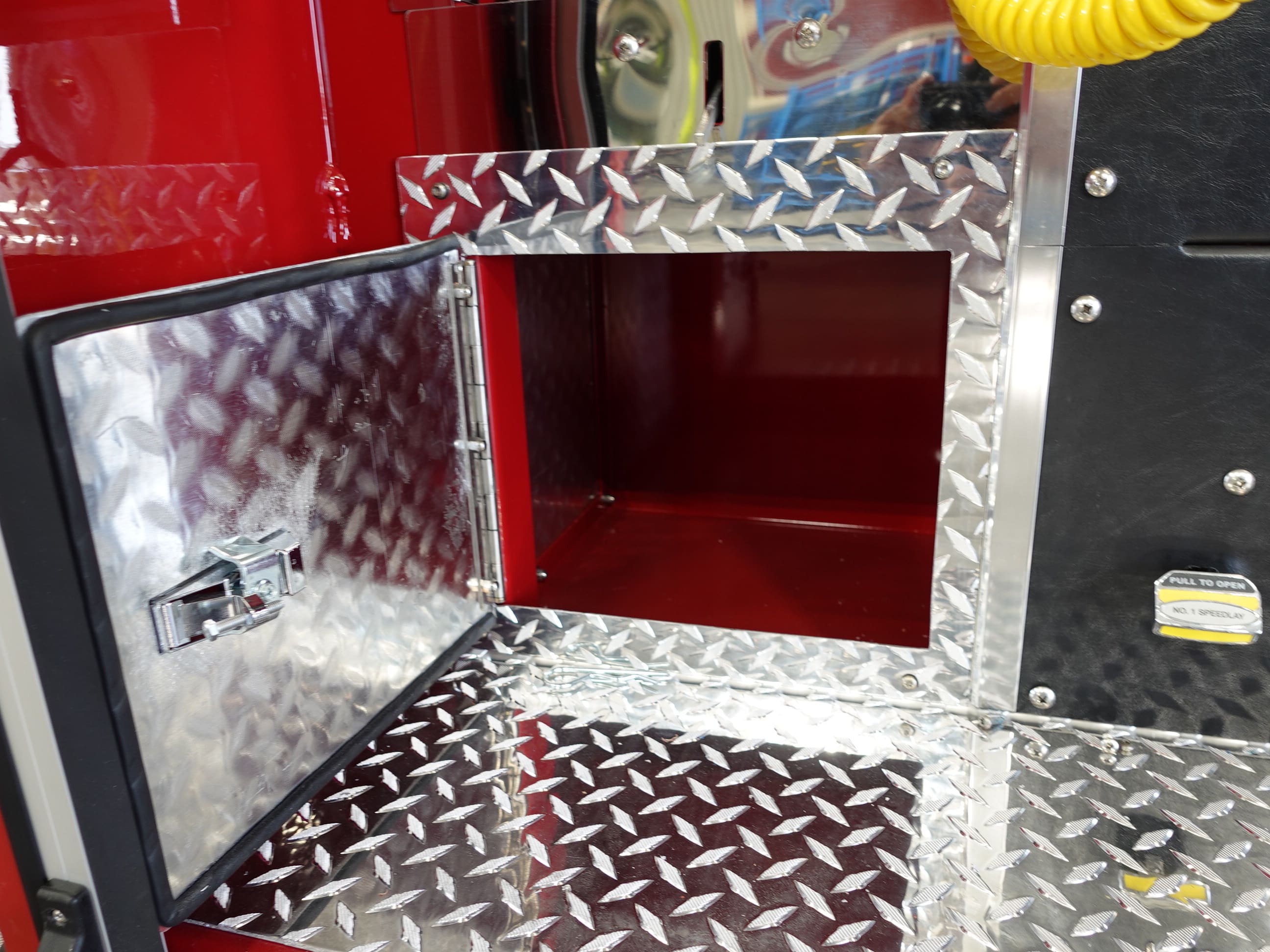

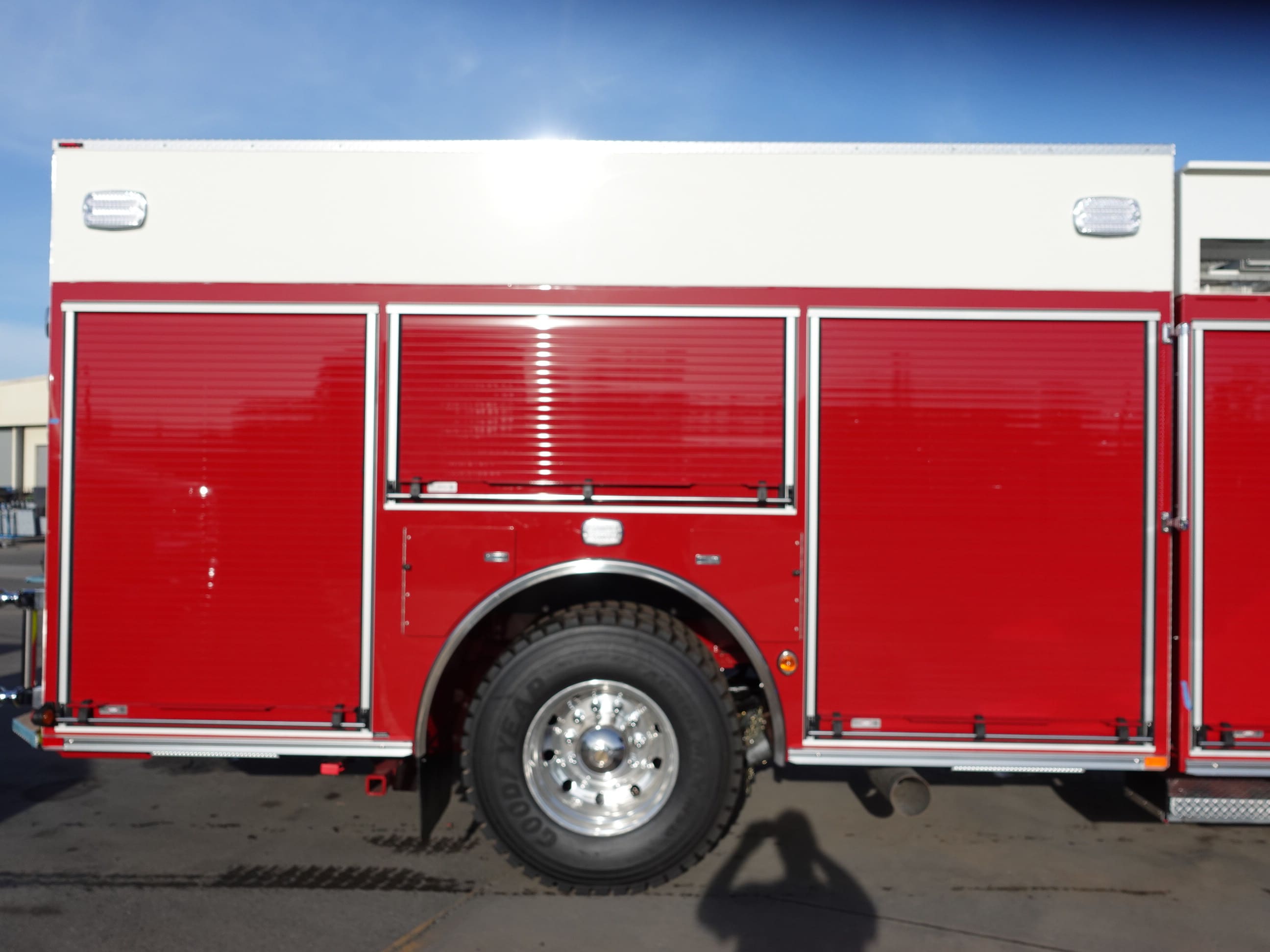

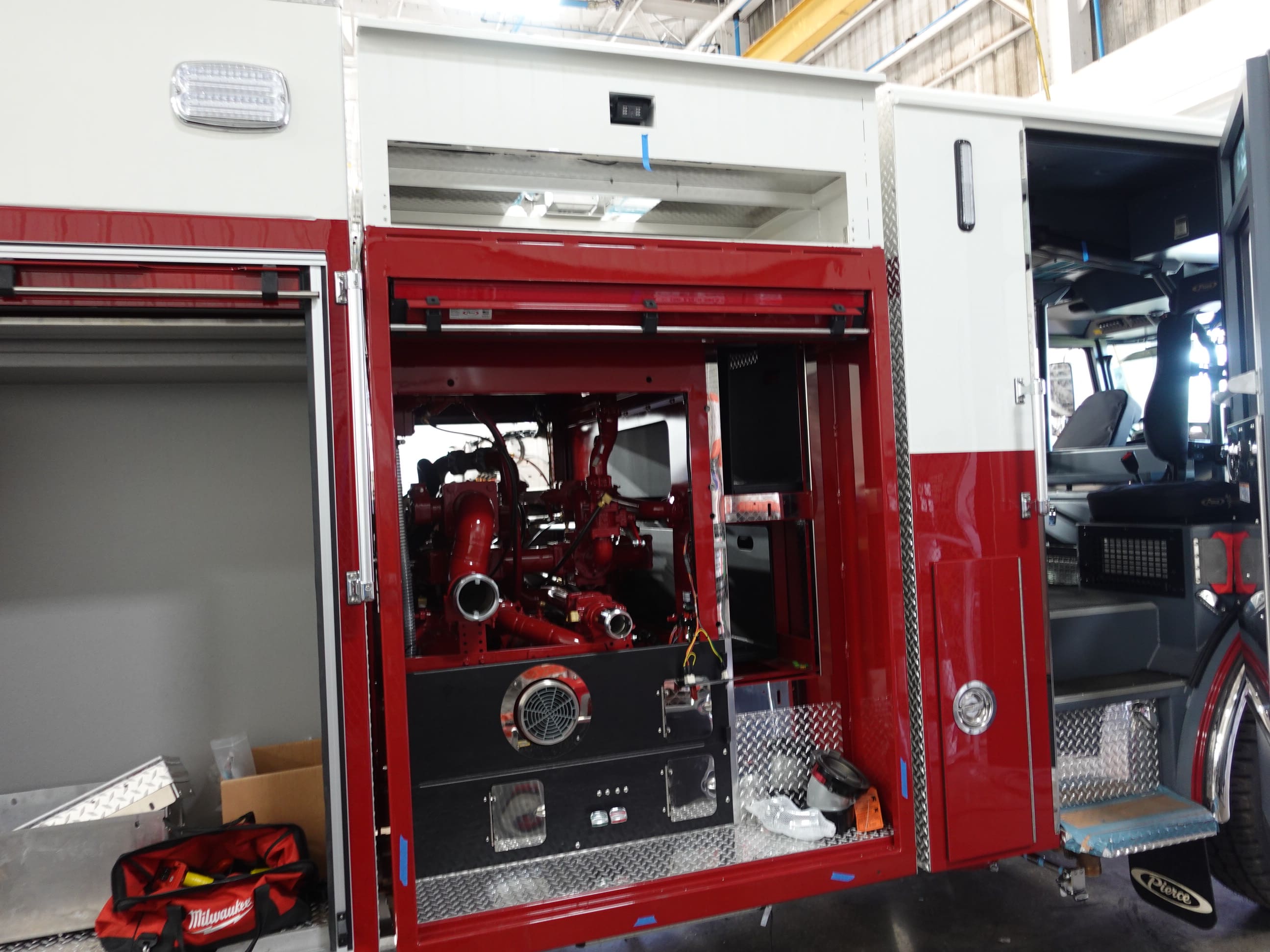

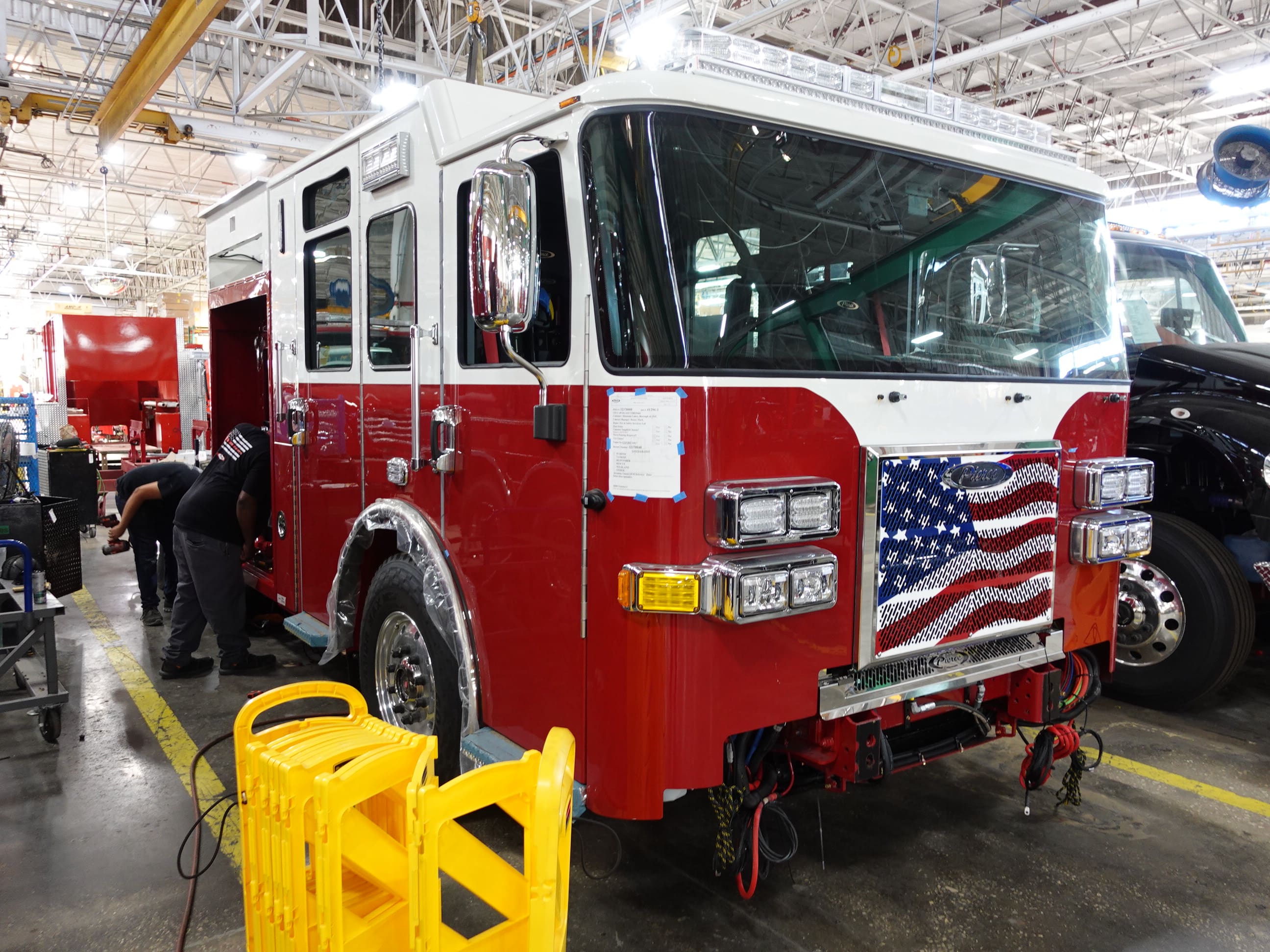

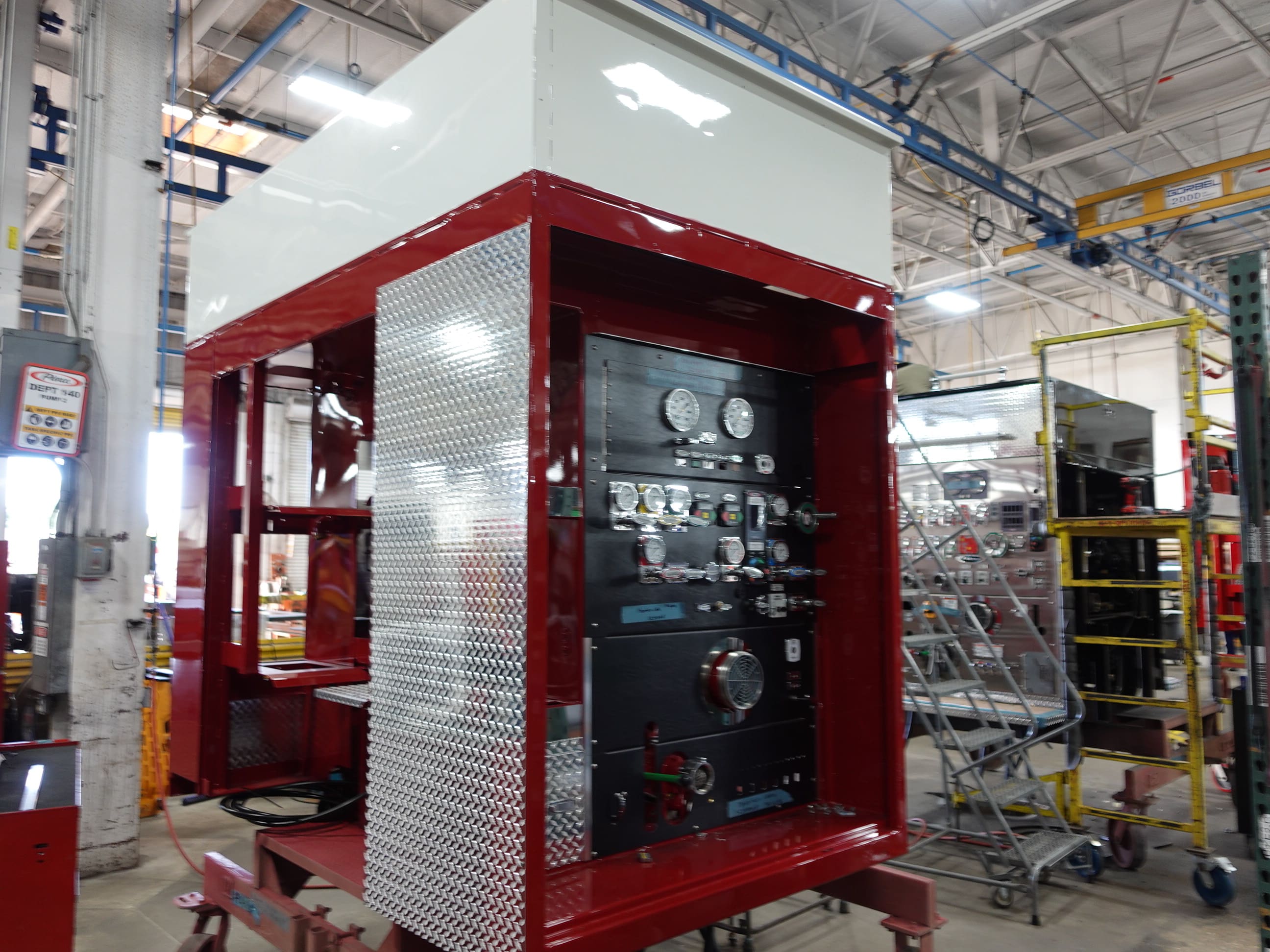

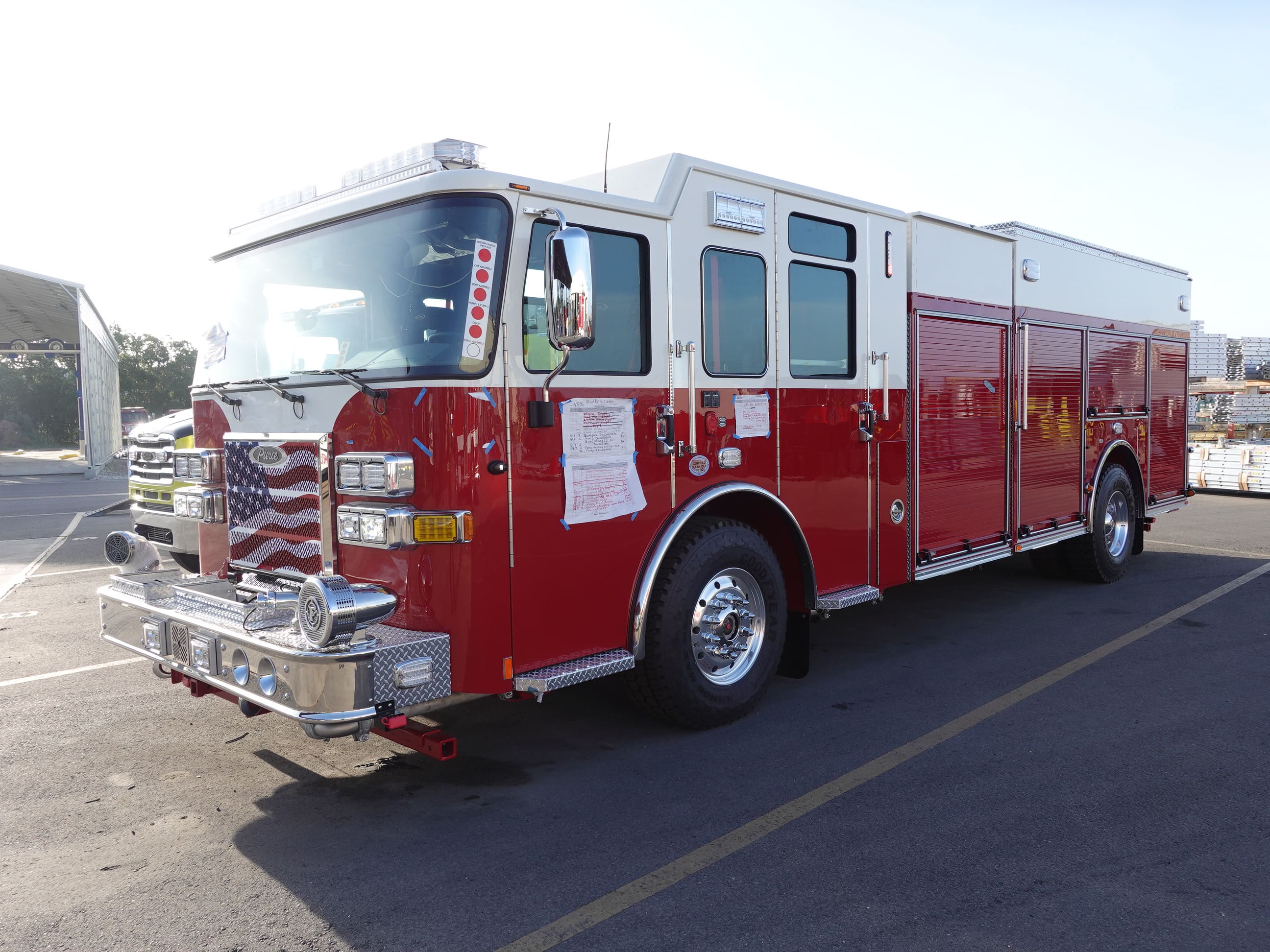

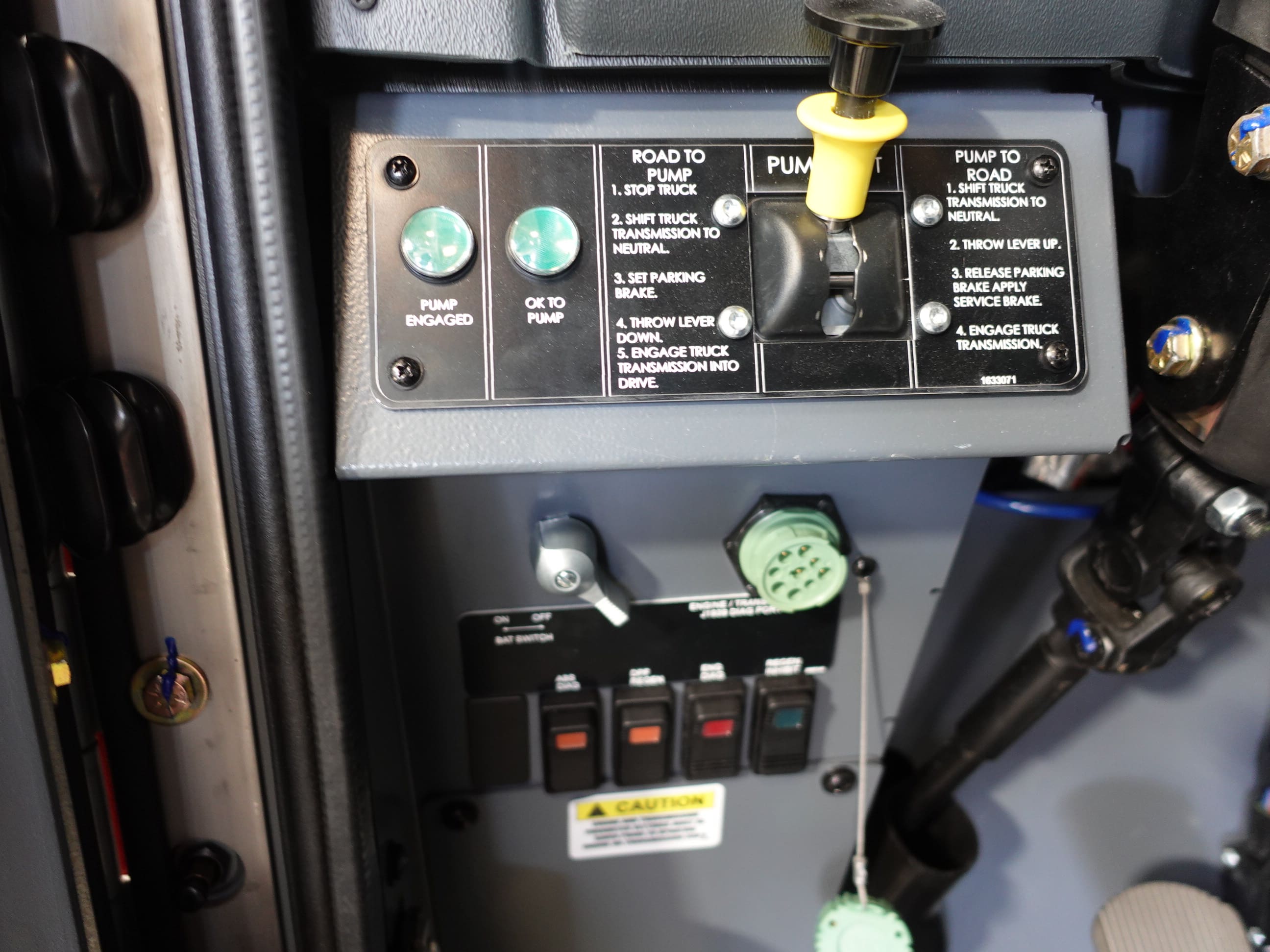

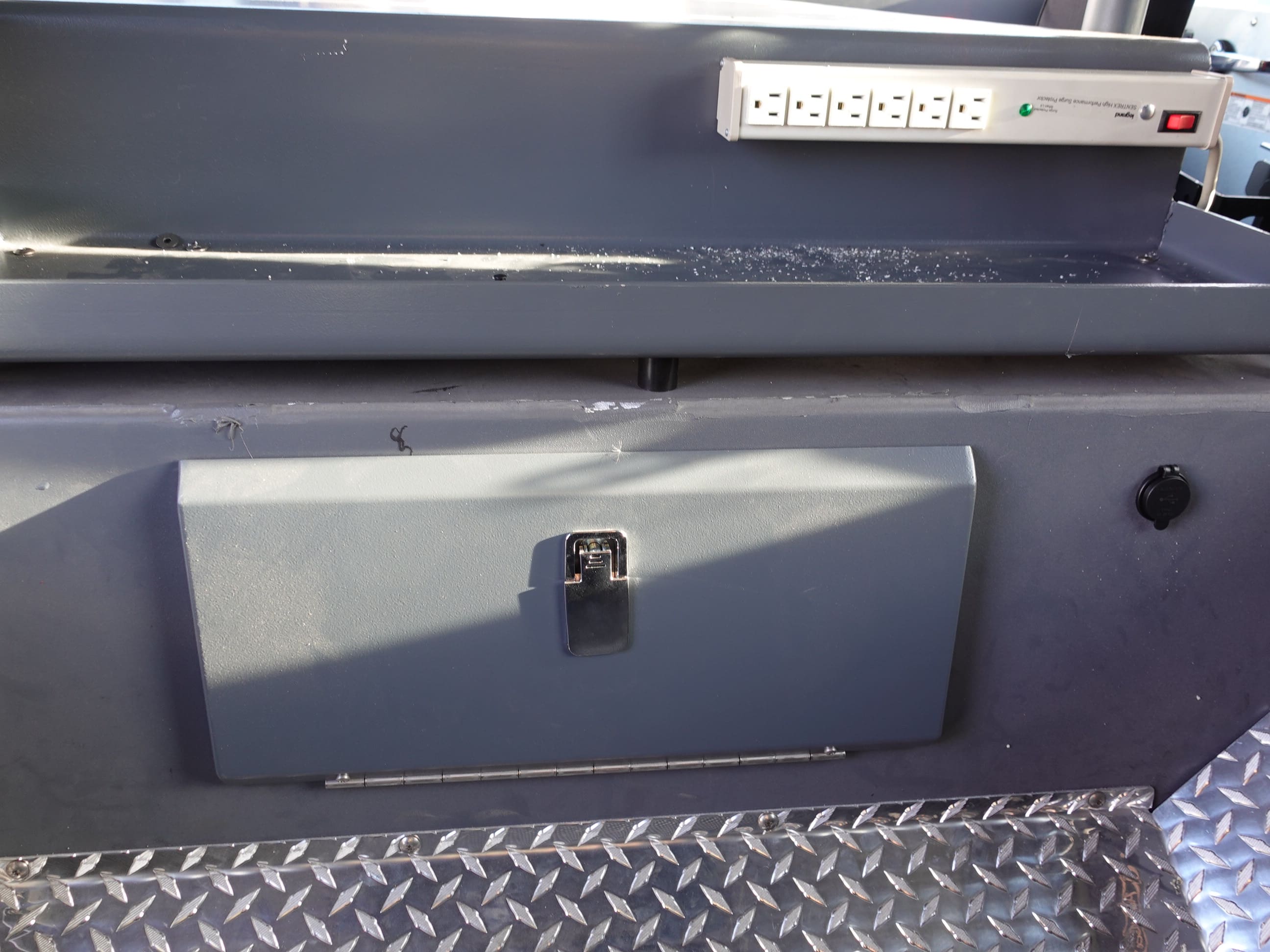

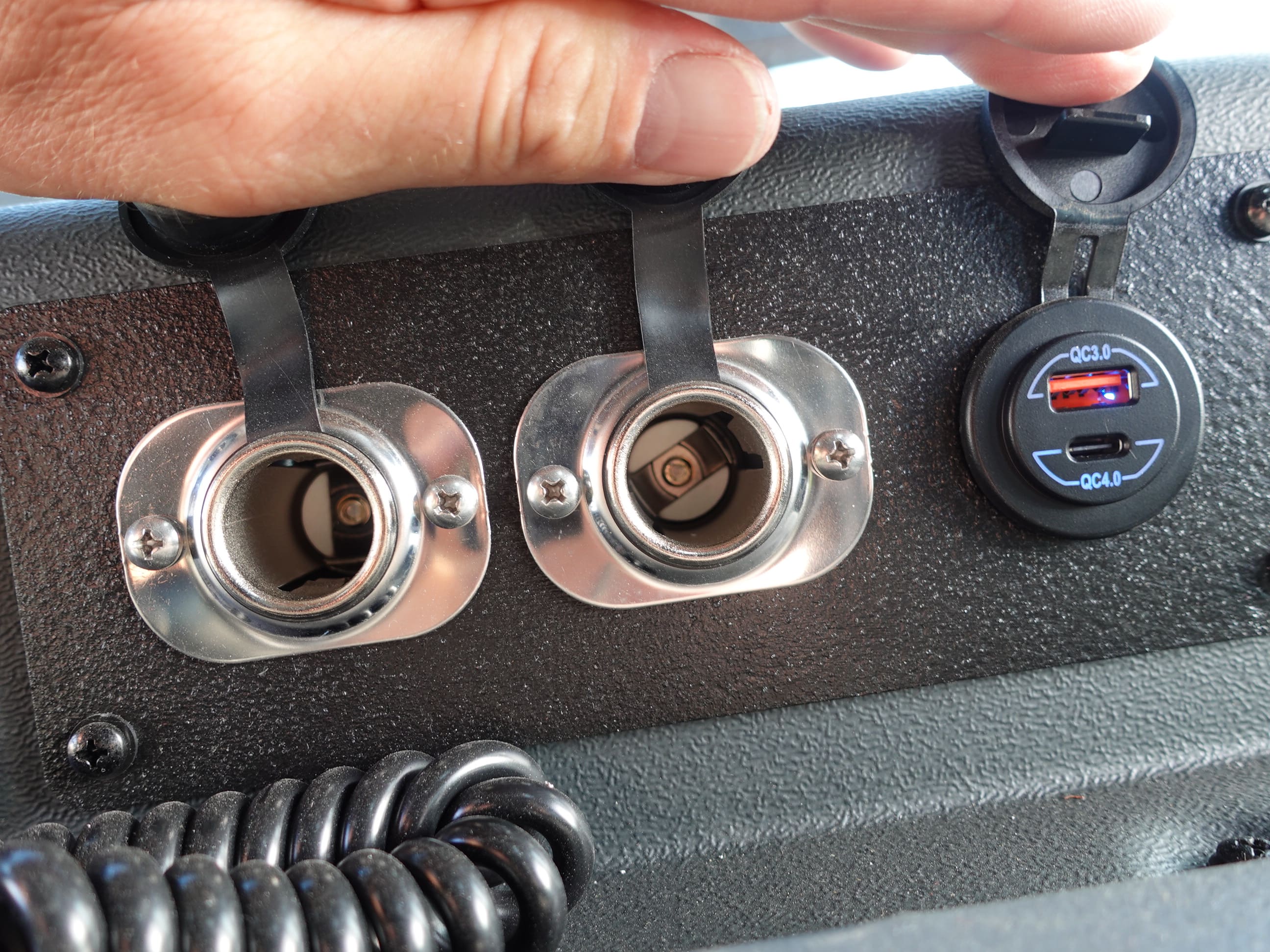

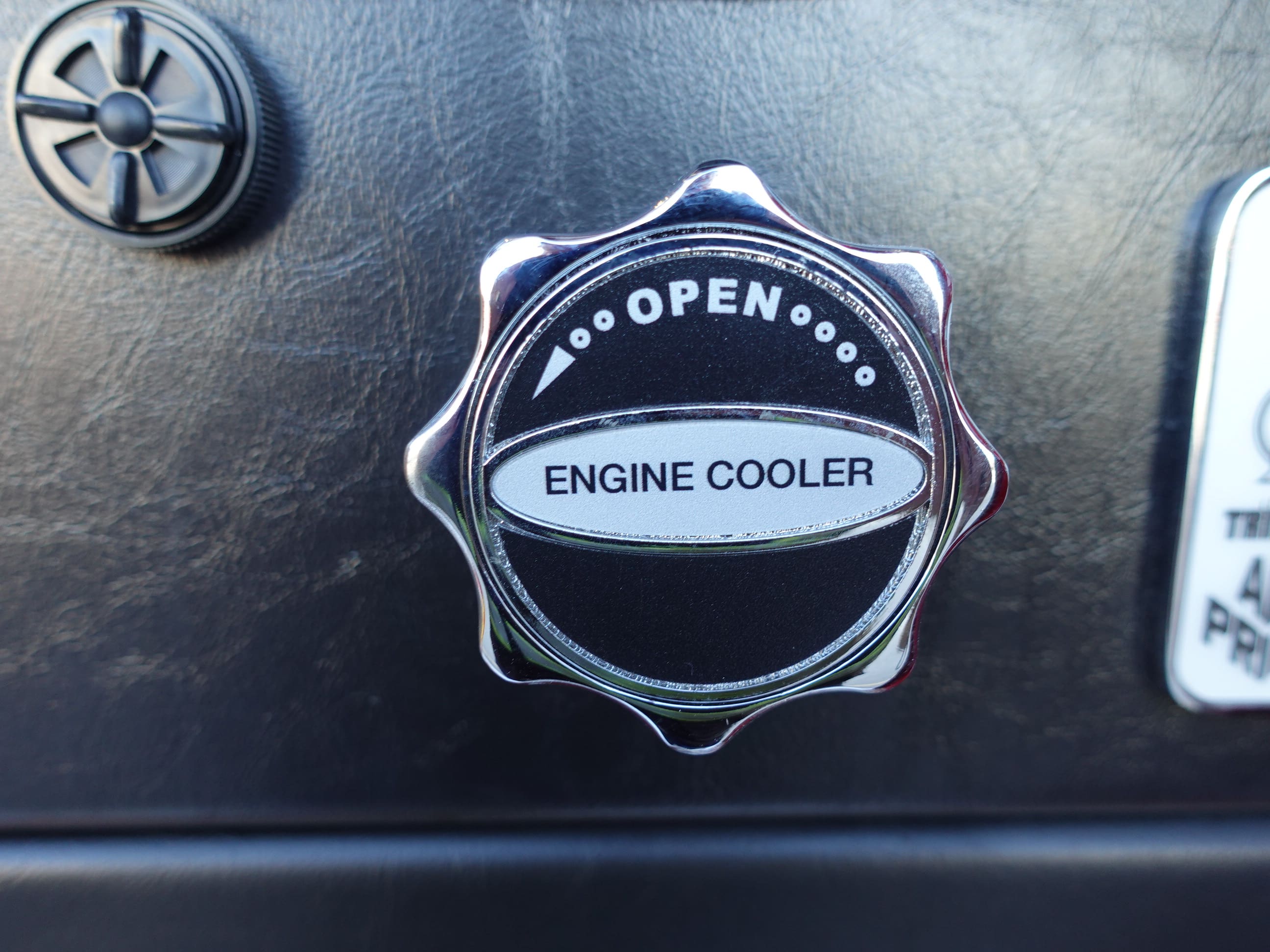

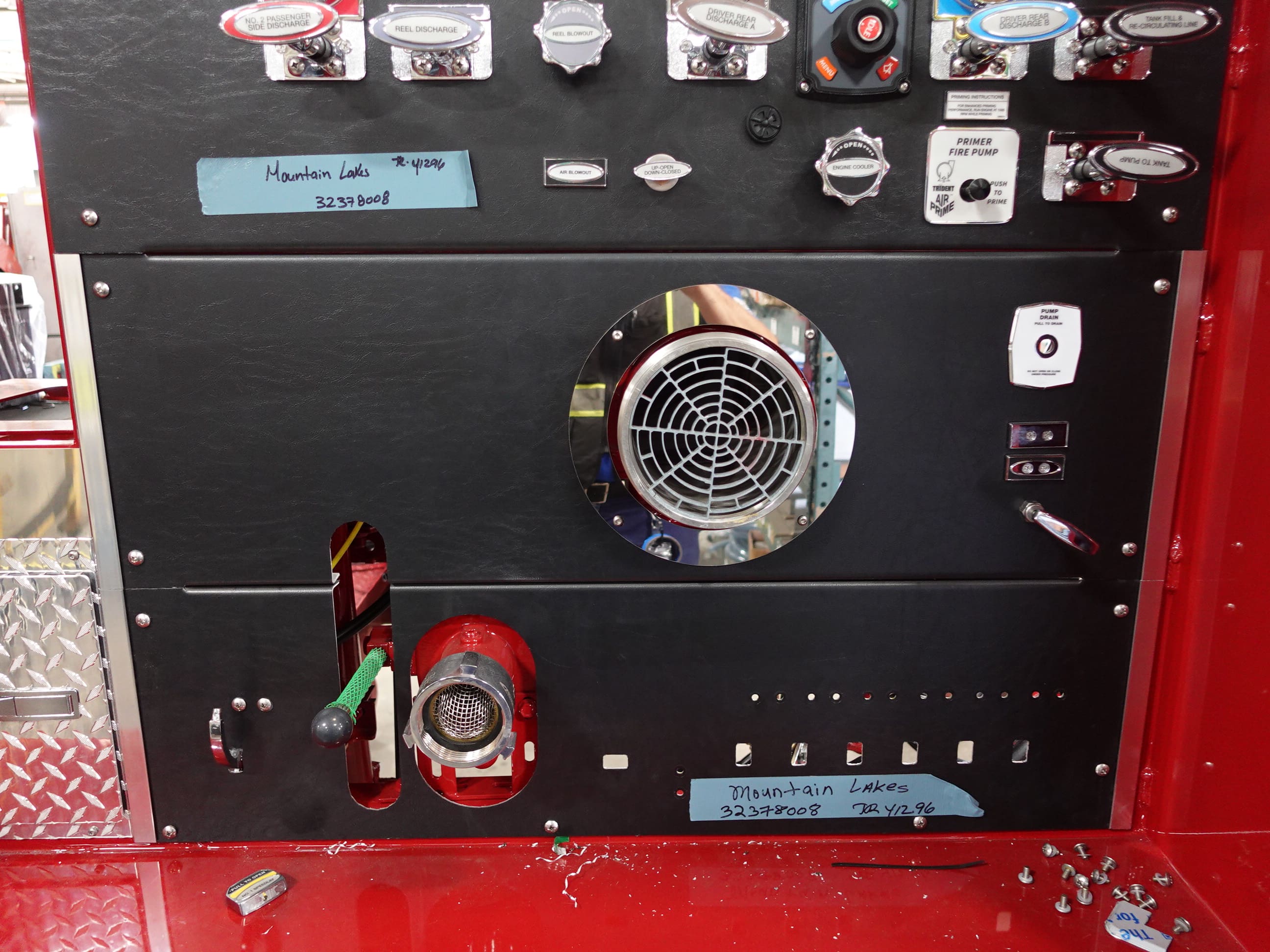

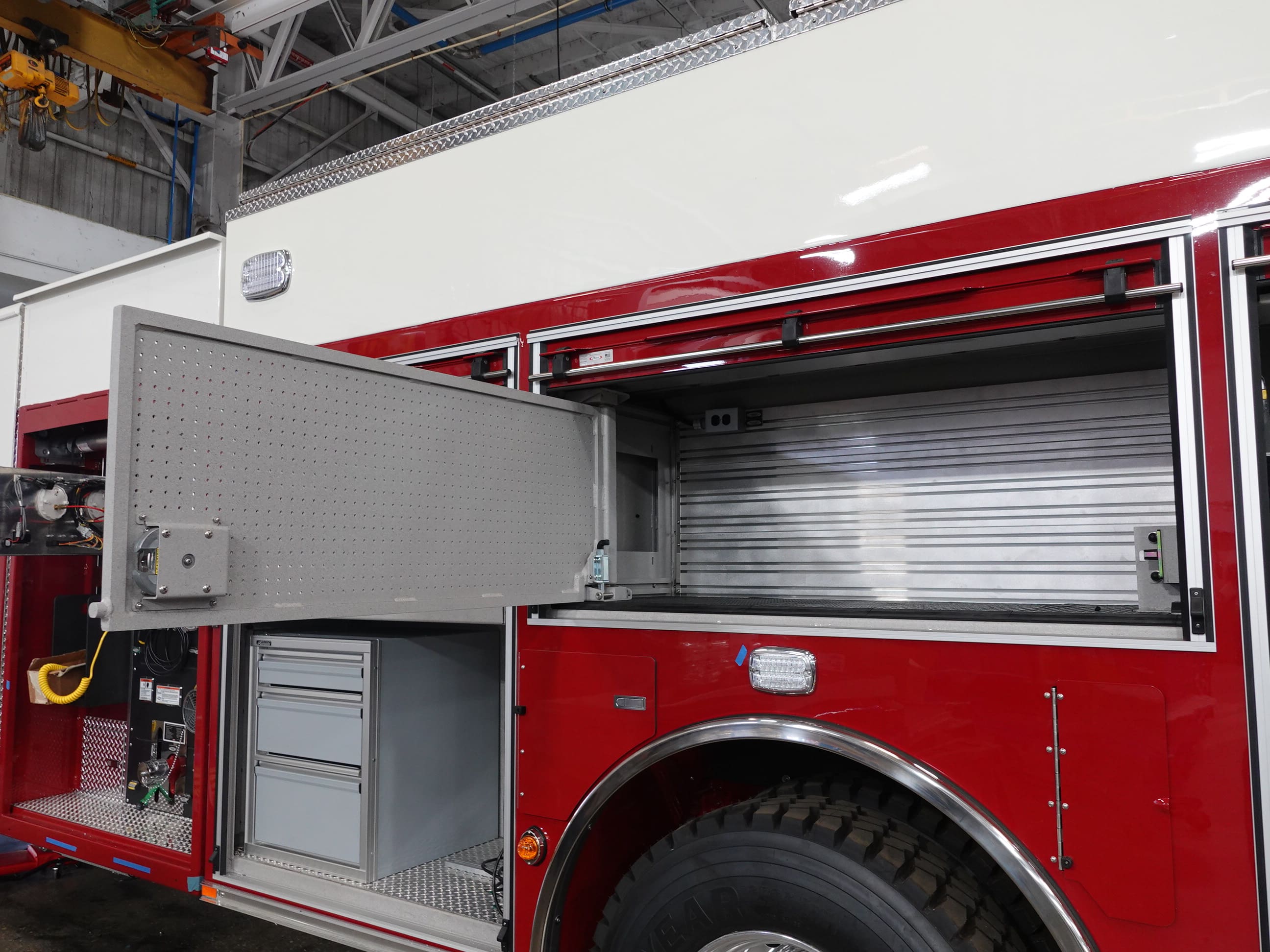

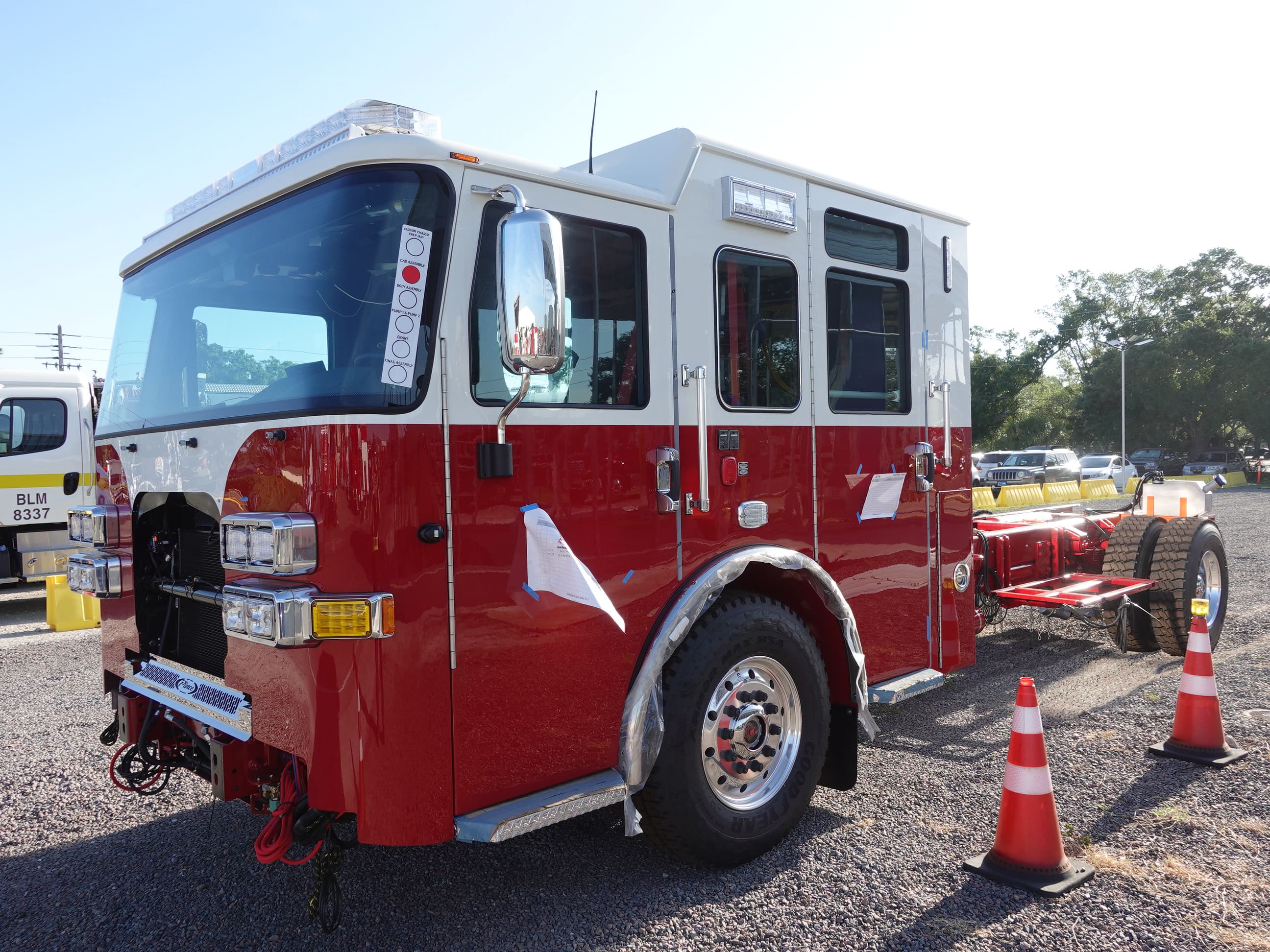

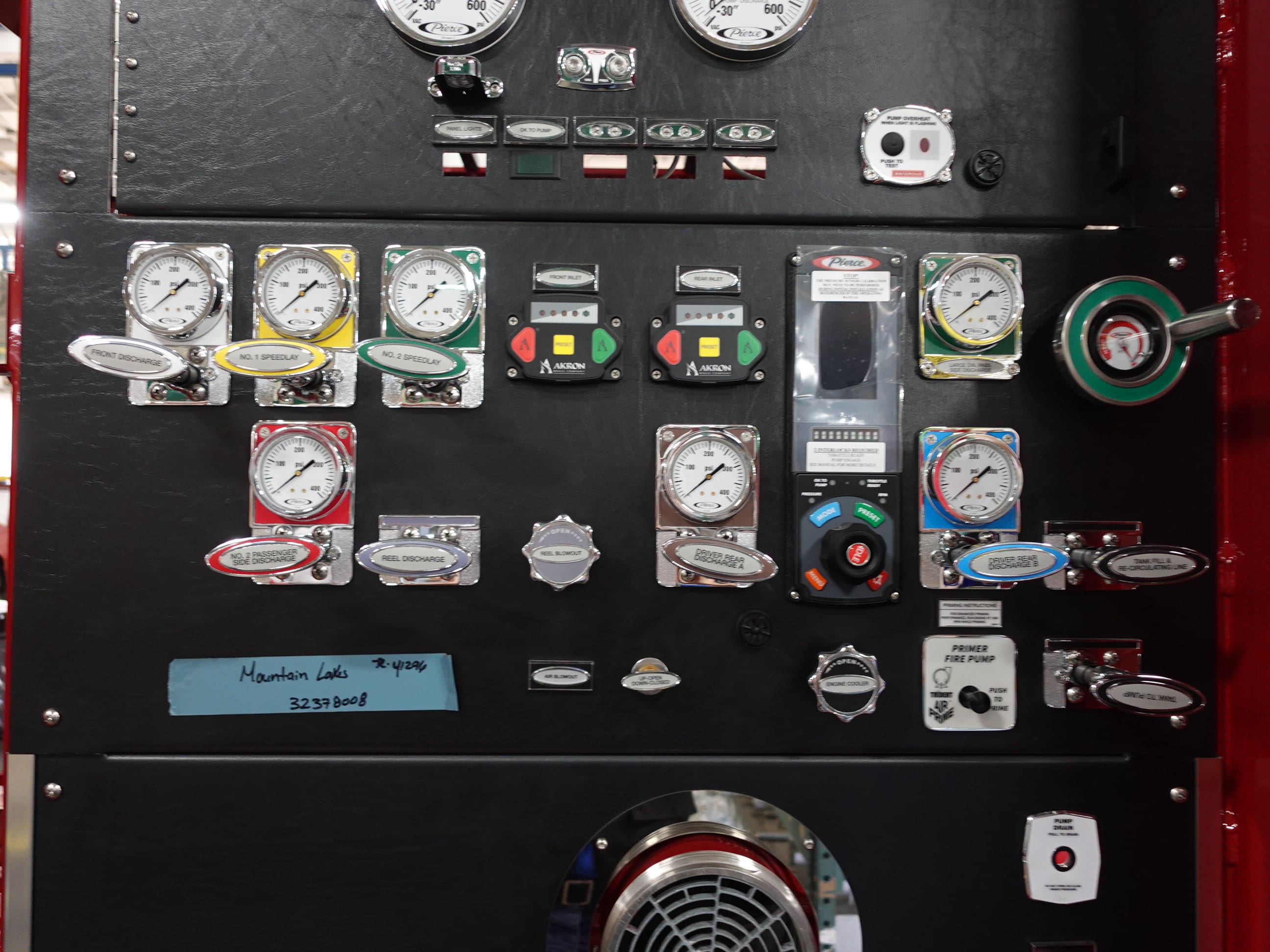

In this report, the apparatus completed final assembly and released to test. When testing completes it will release to final product evaluation where any
remaining content will be applied. Once finished it will be made ready for the customer acceptance

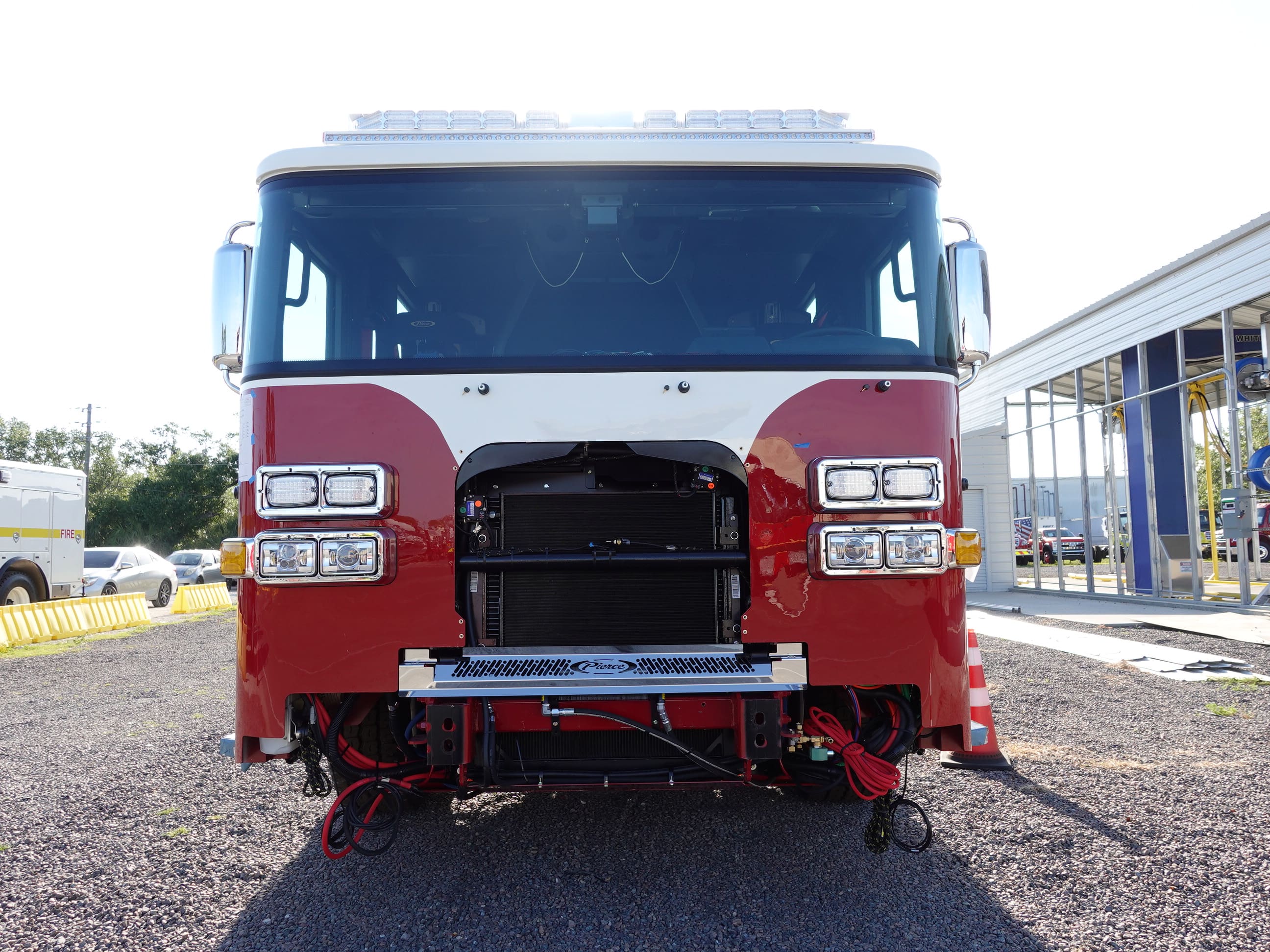

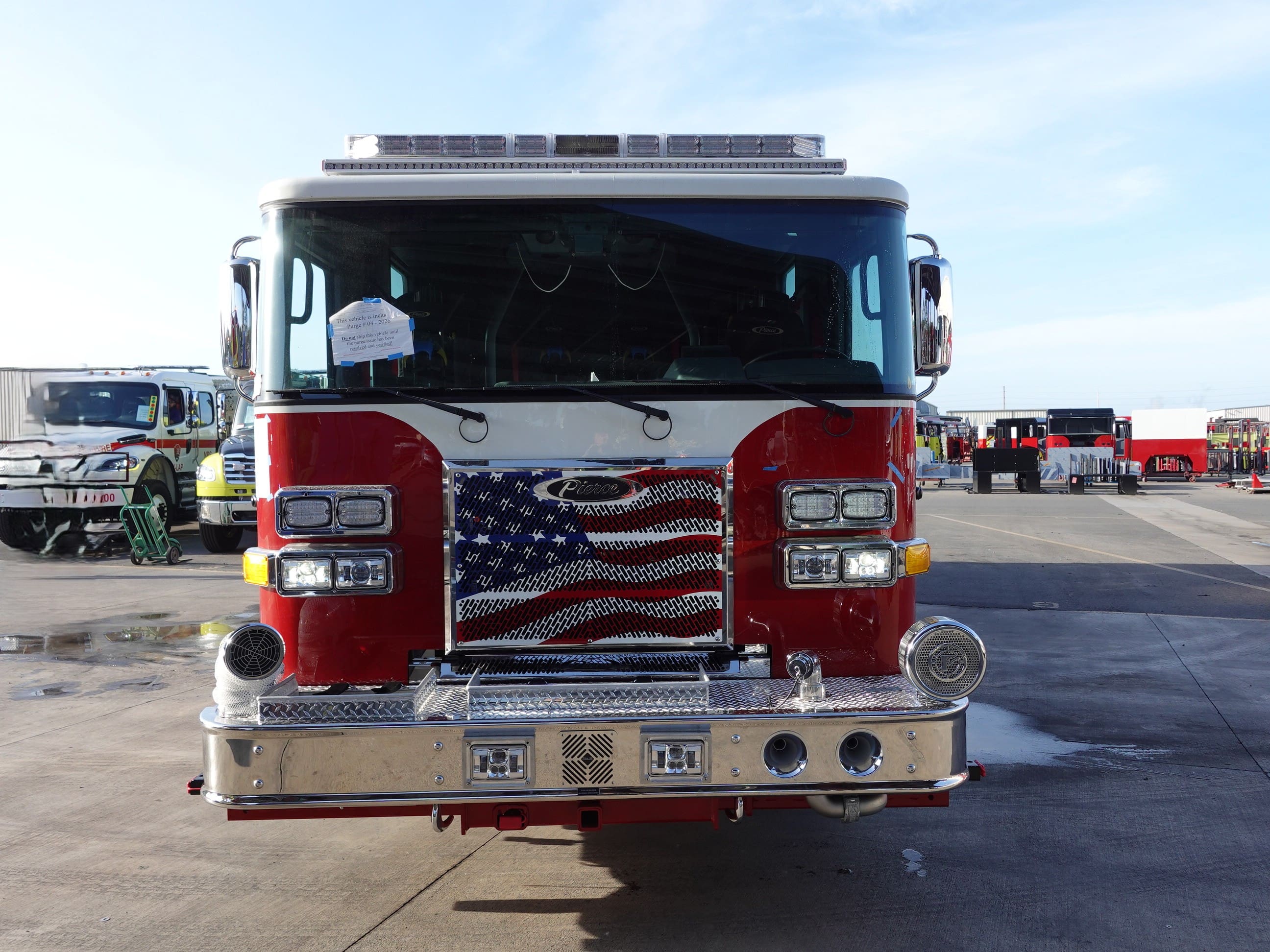

inspection. This is the last scheduled report.

05-15-26

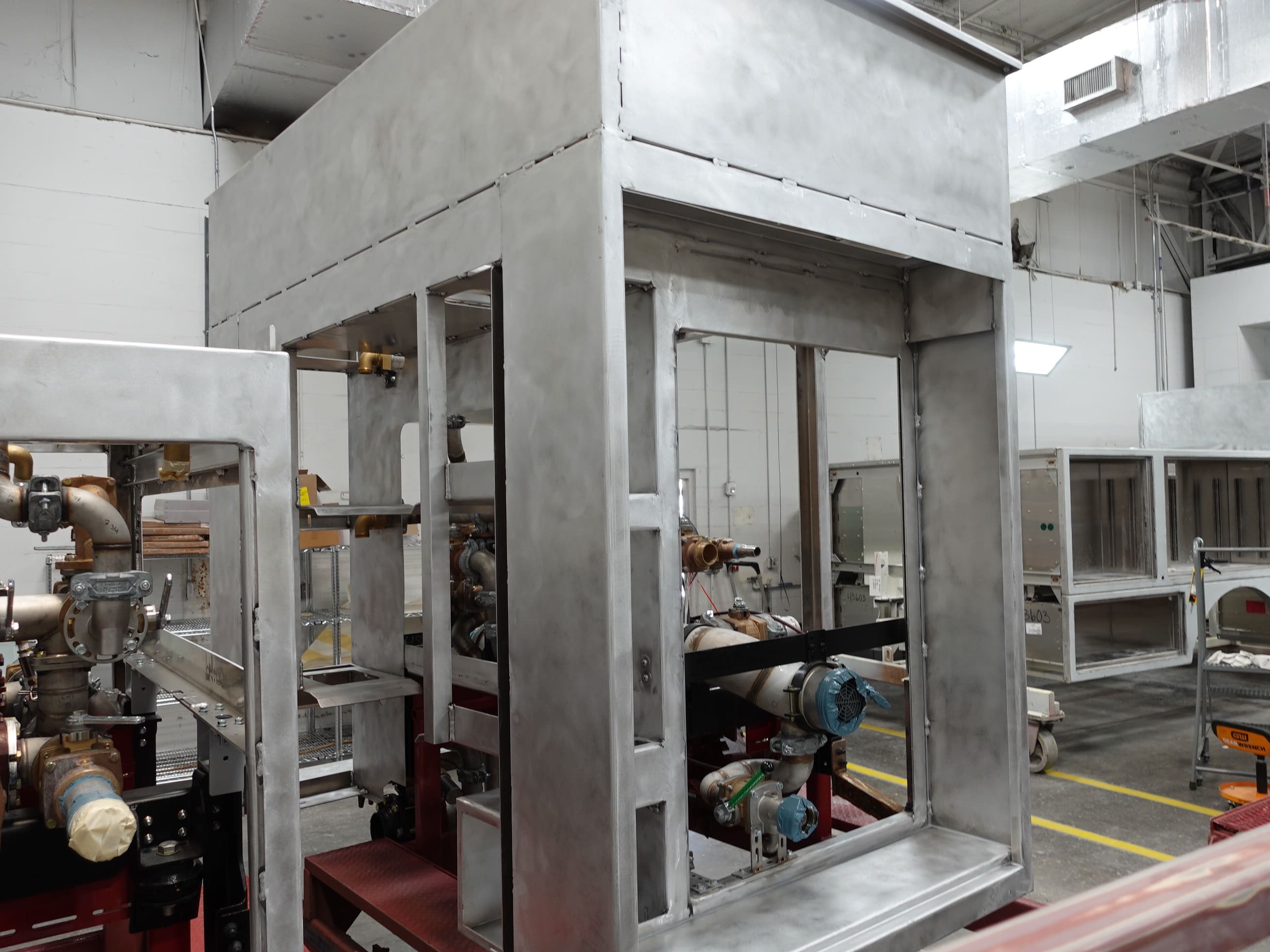

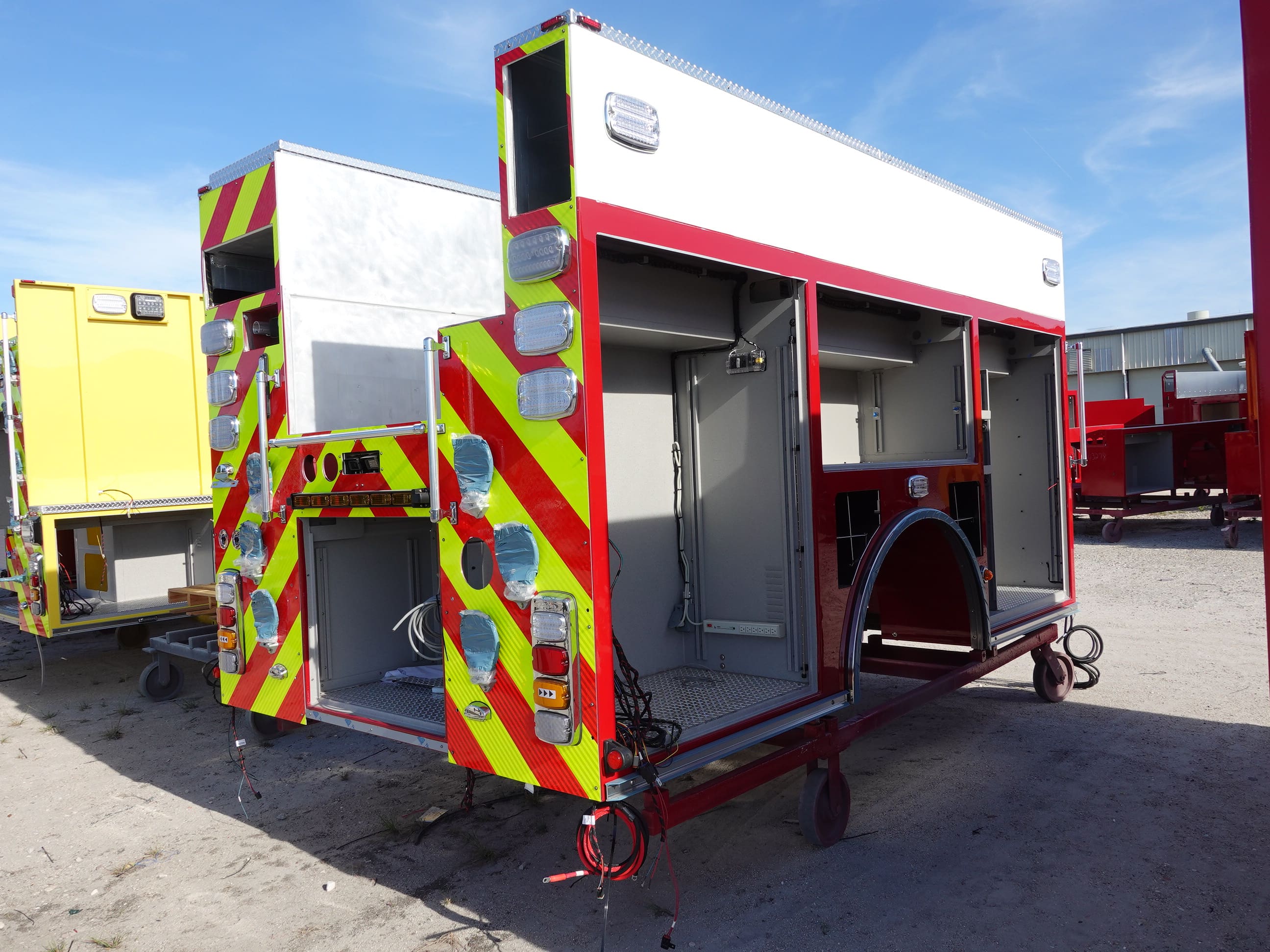

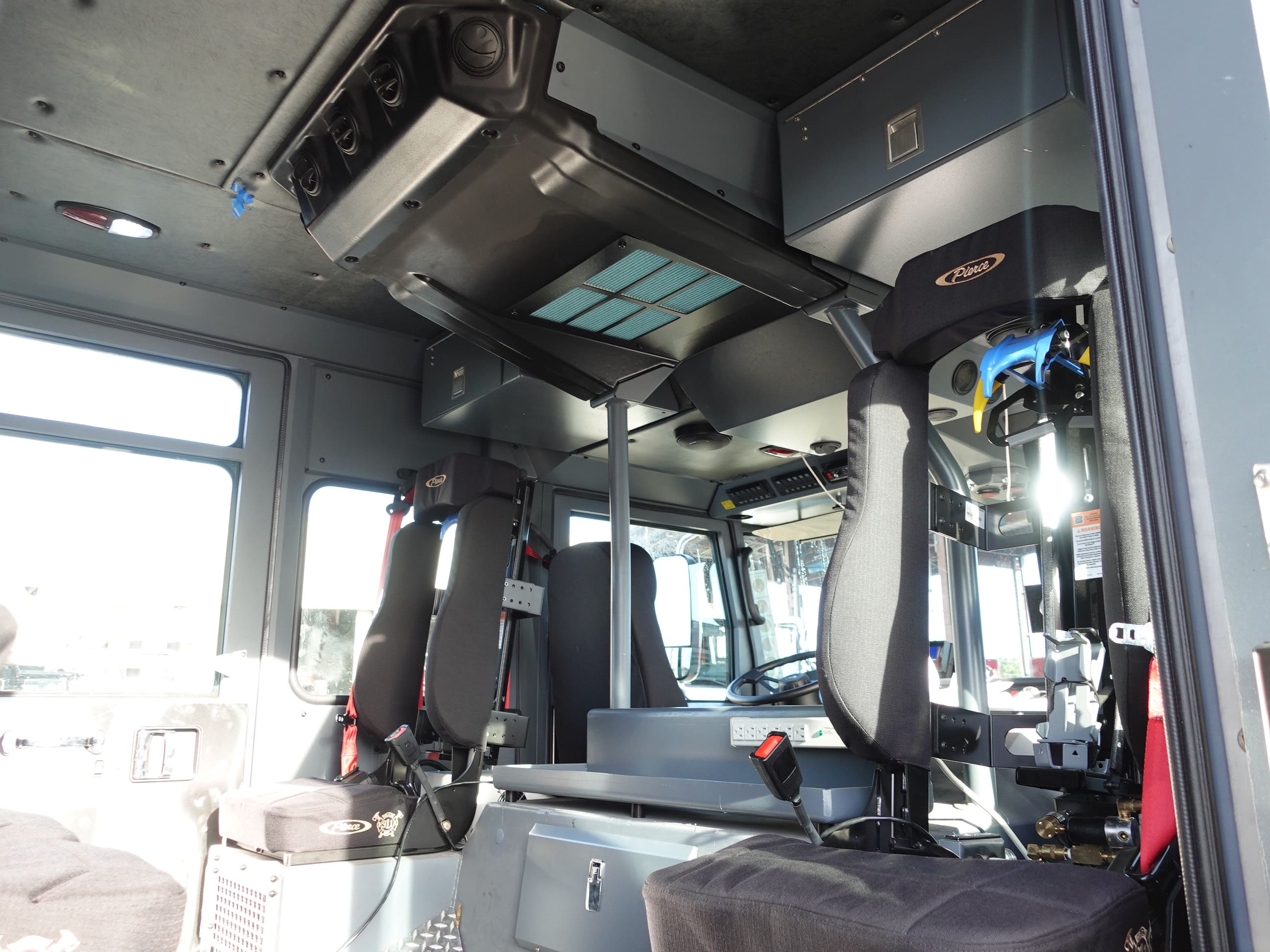

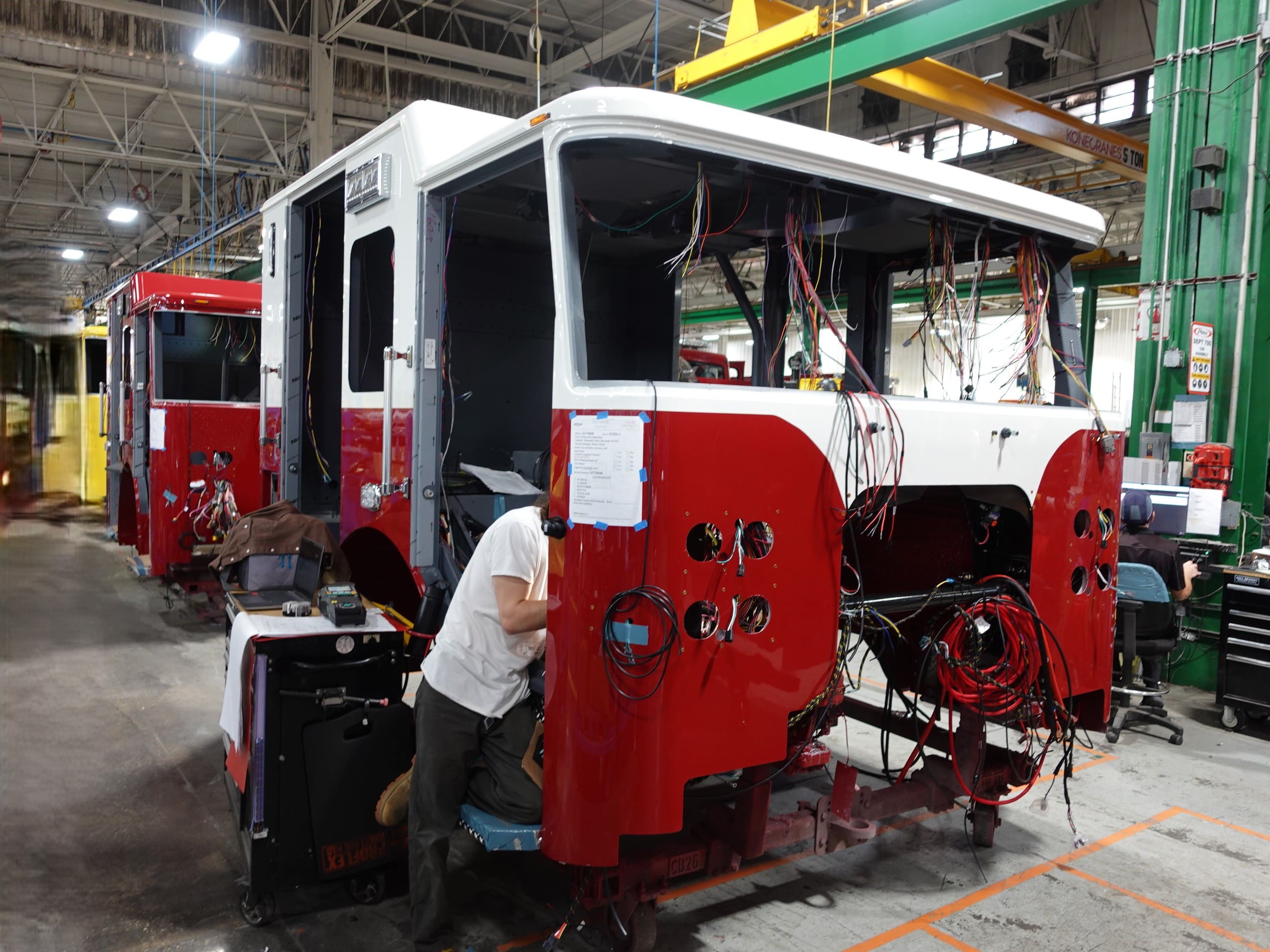

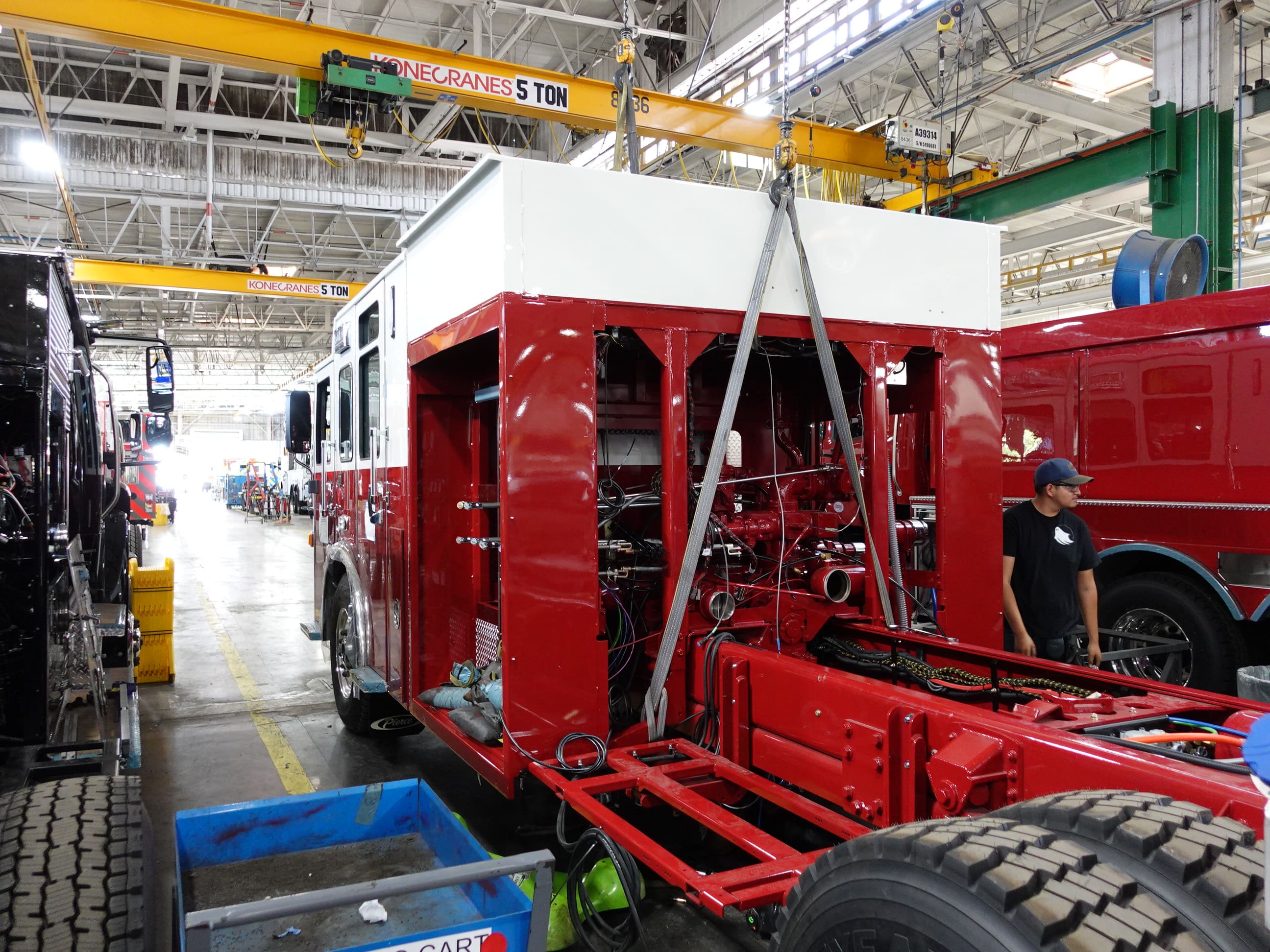

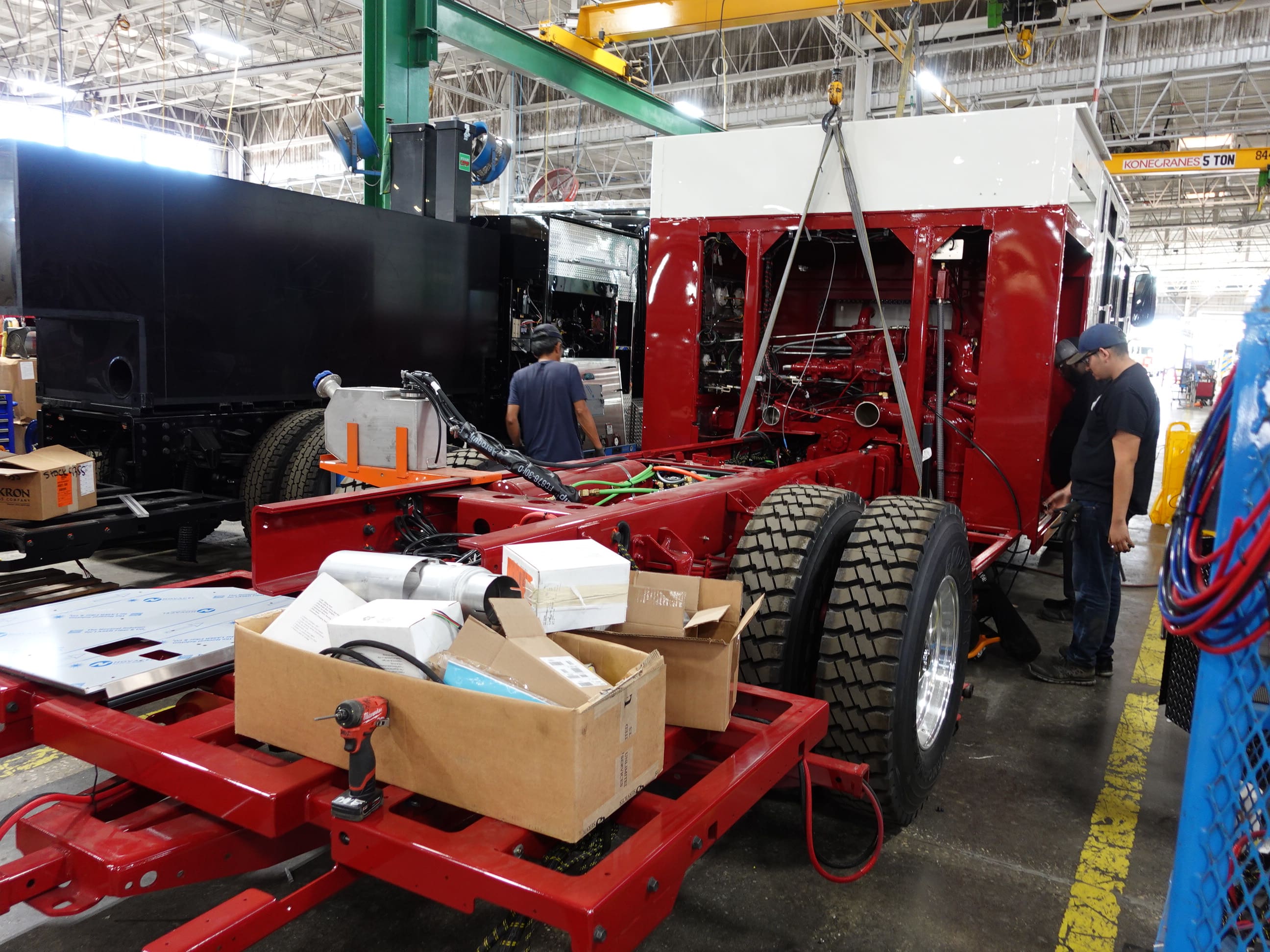

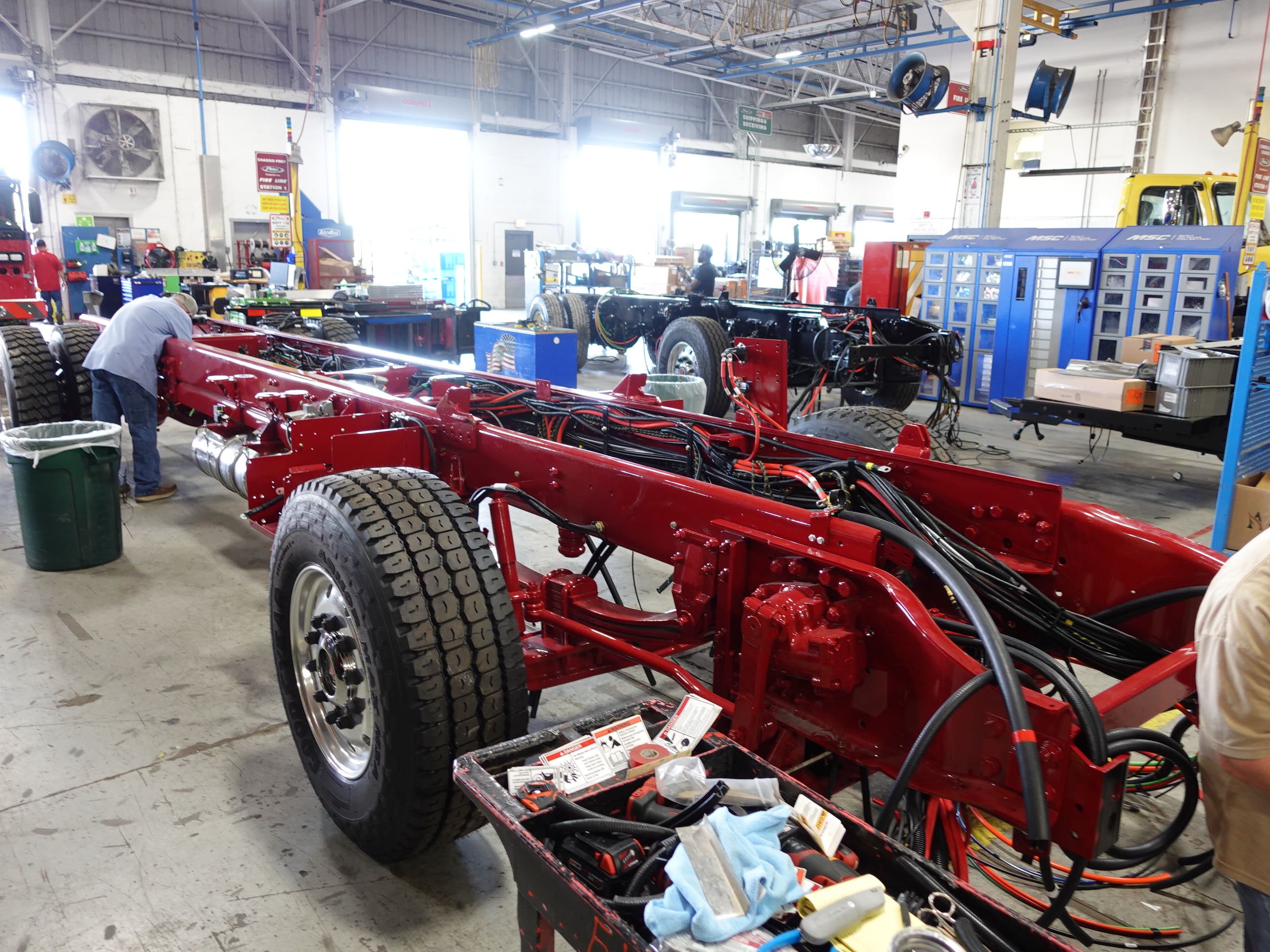

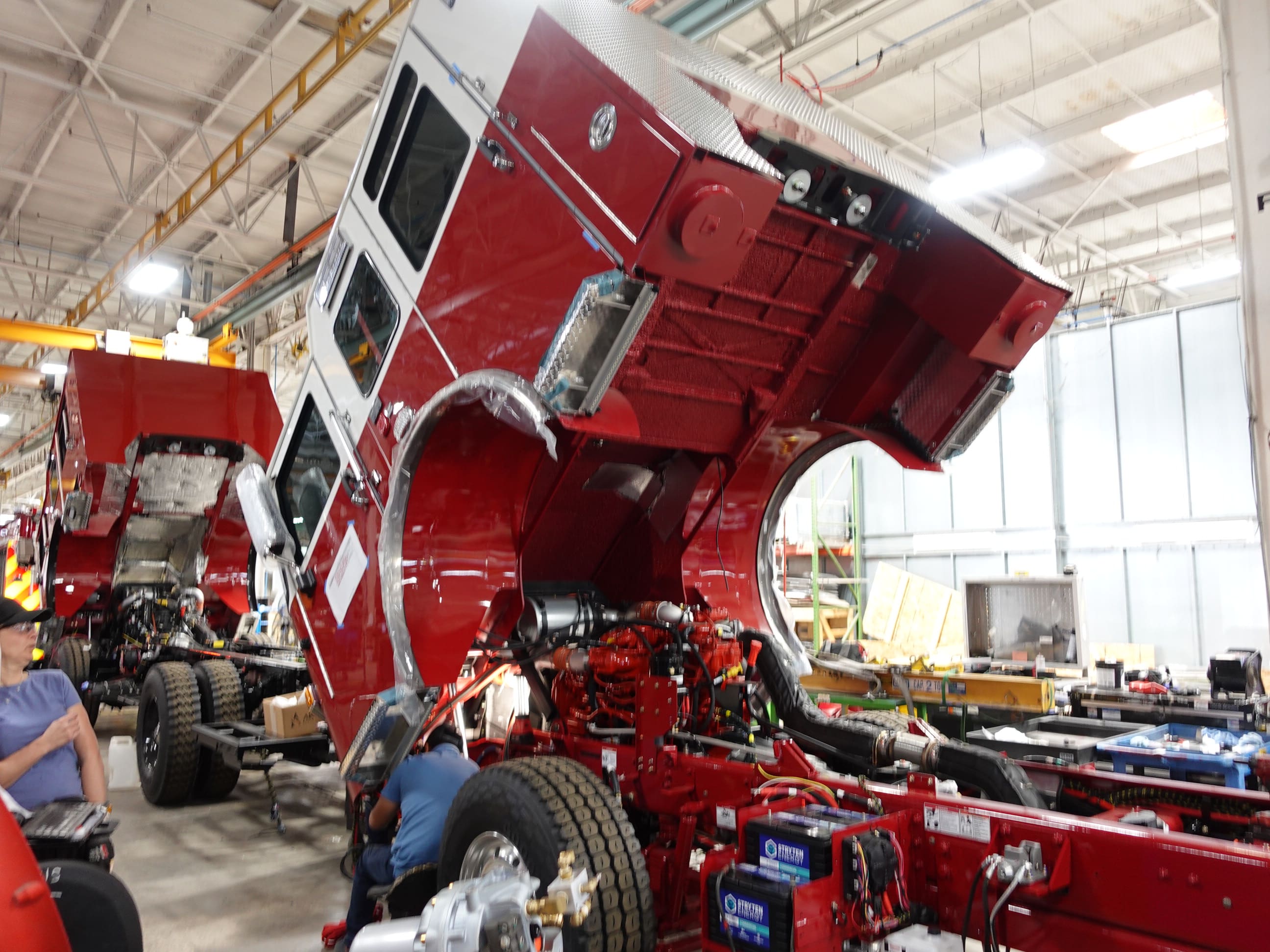

In this report the body was merged with the

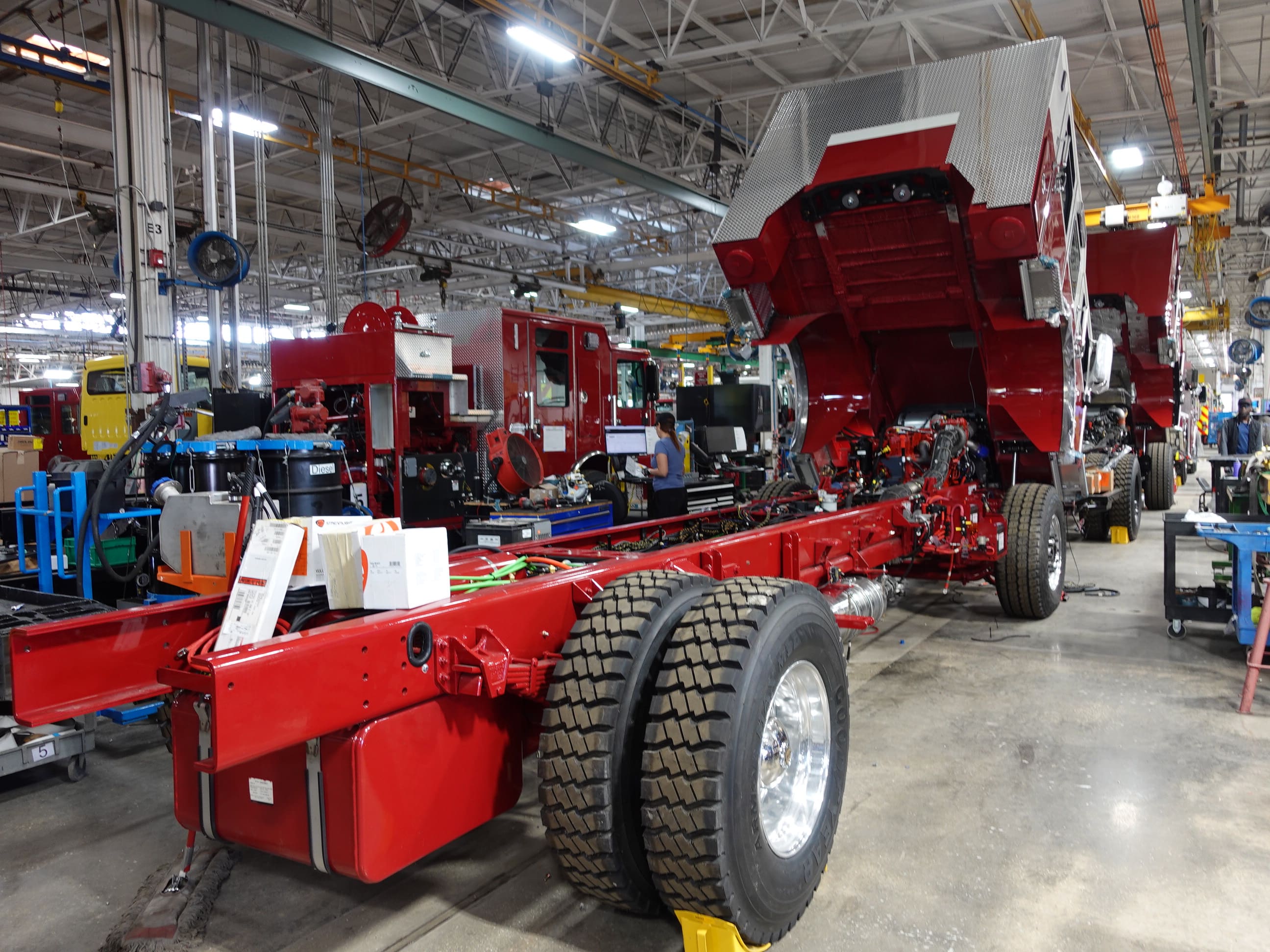

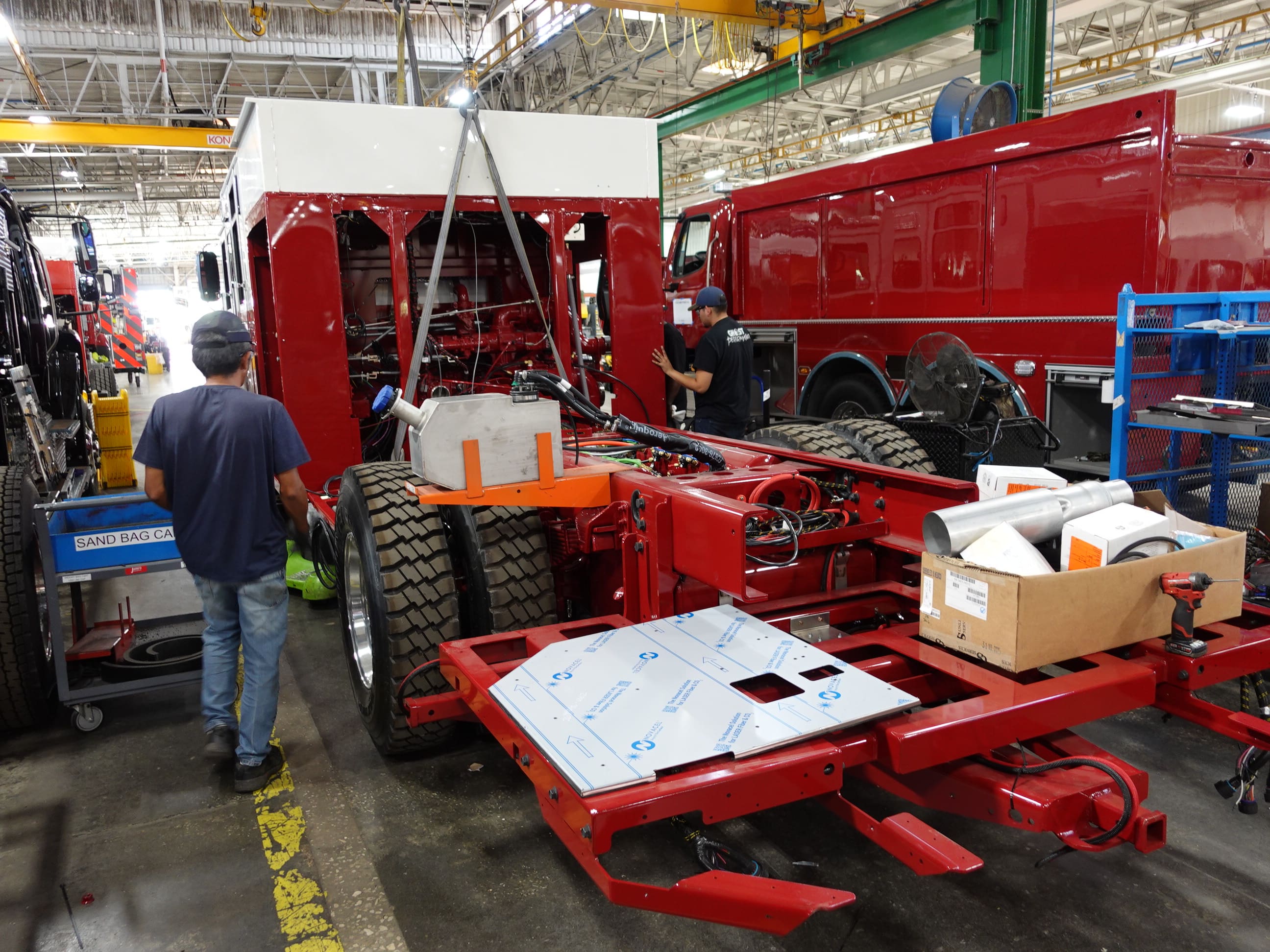

chassis at the start of initial apparatus assembly
followed by the start of final assembly.

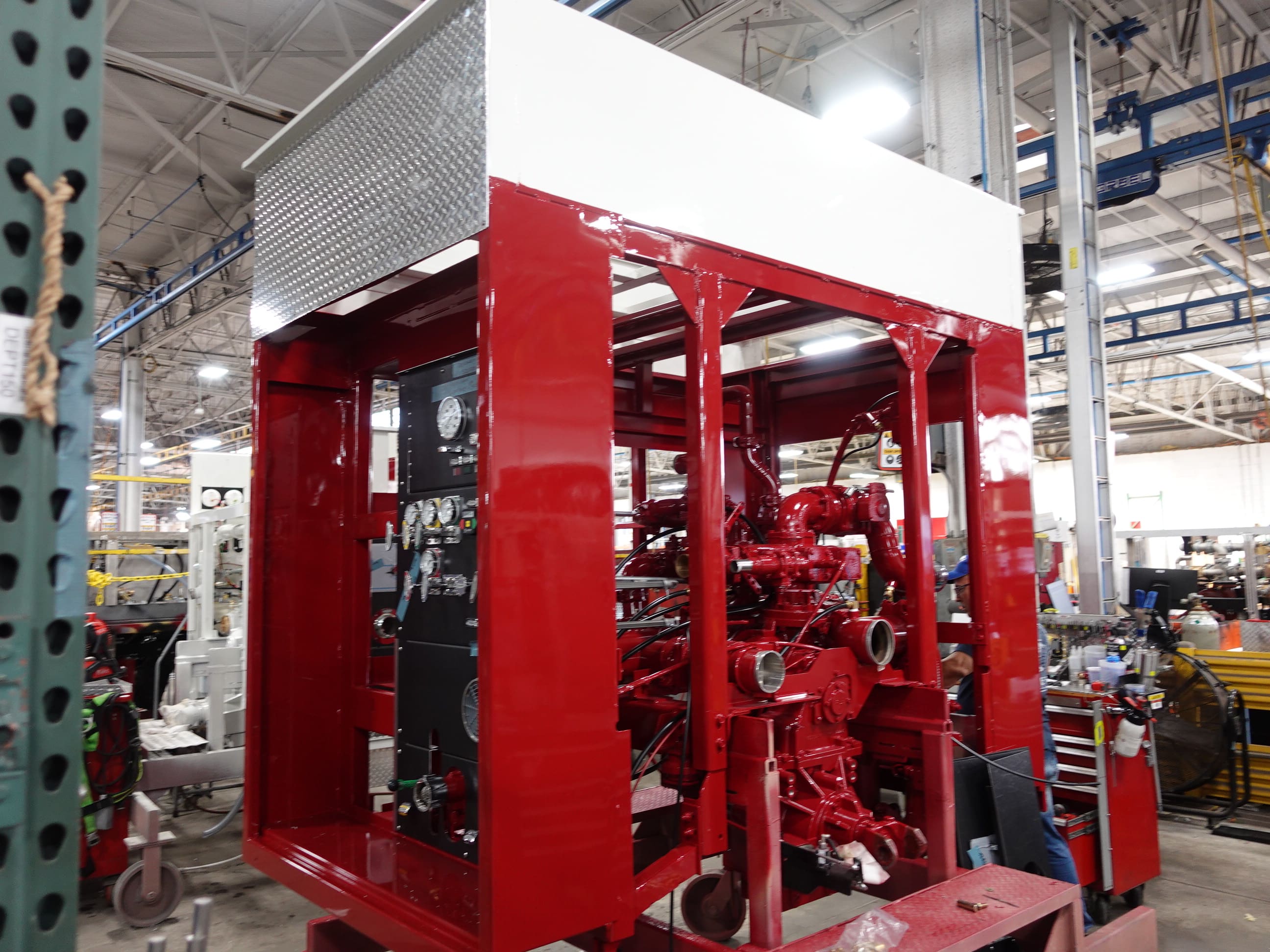

05-01-26

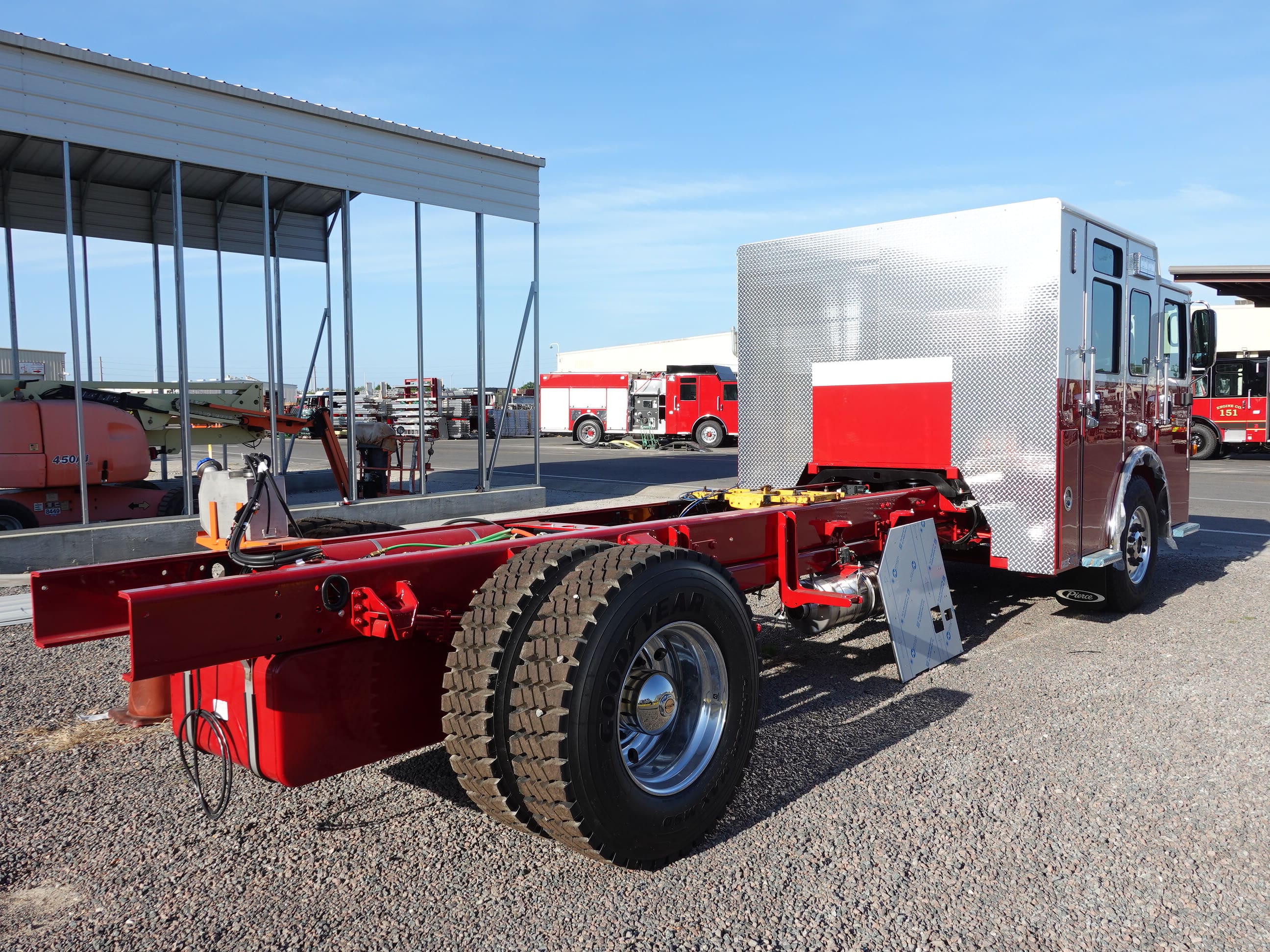

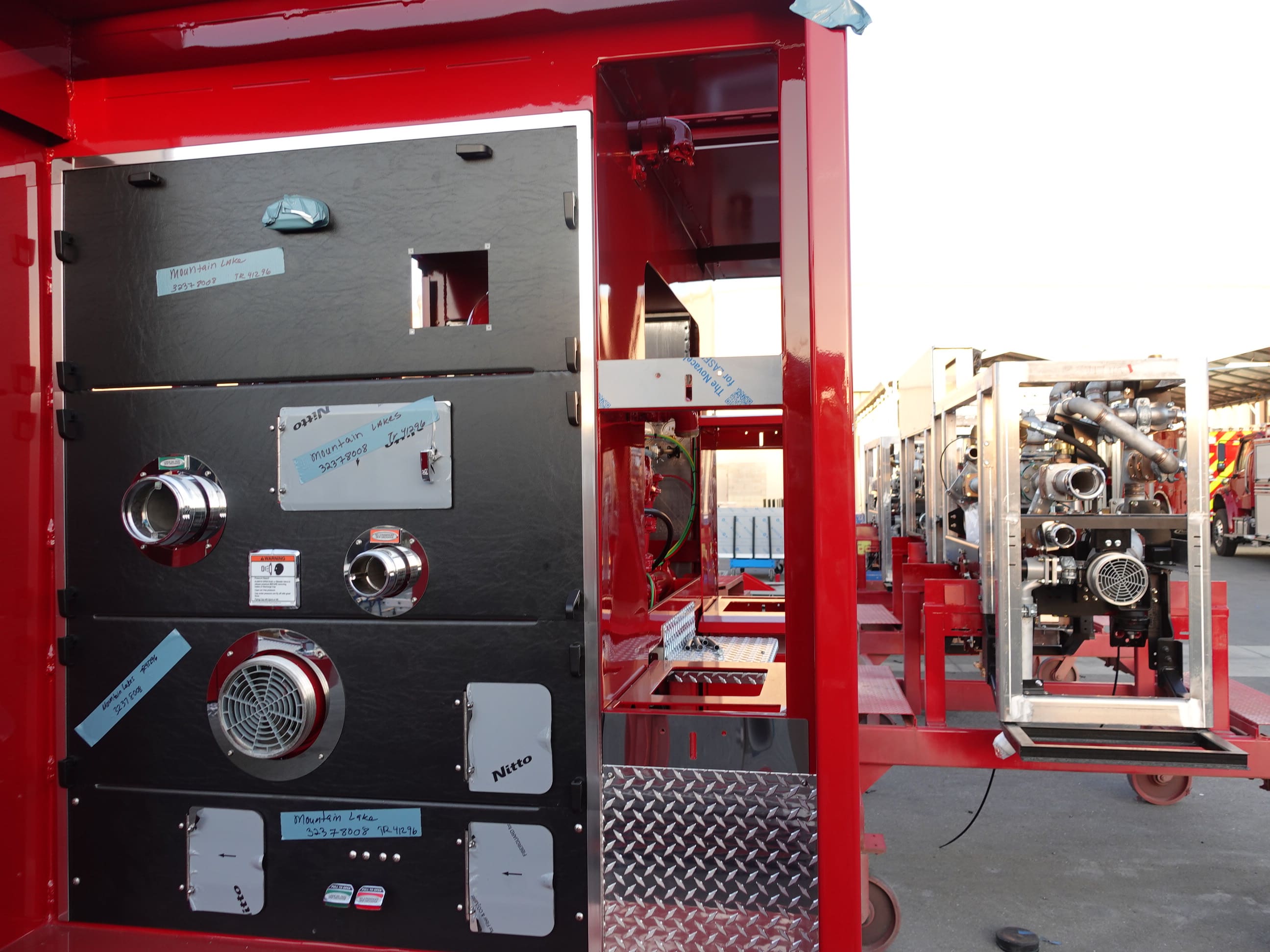

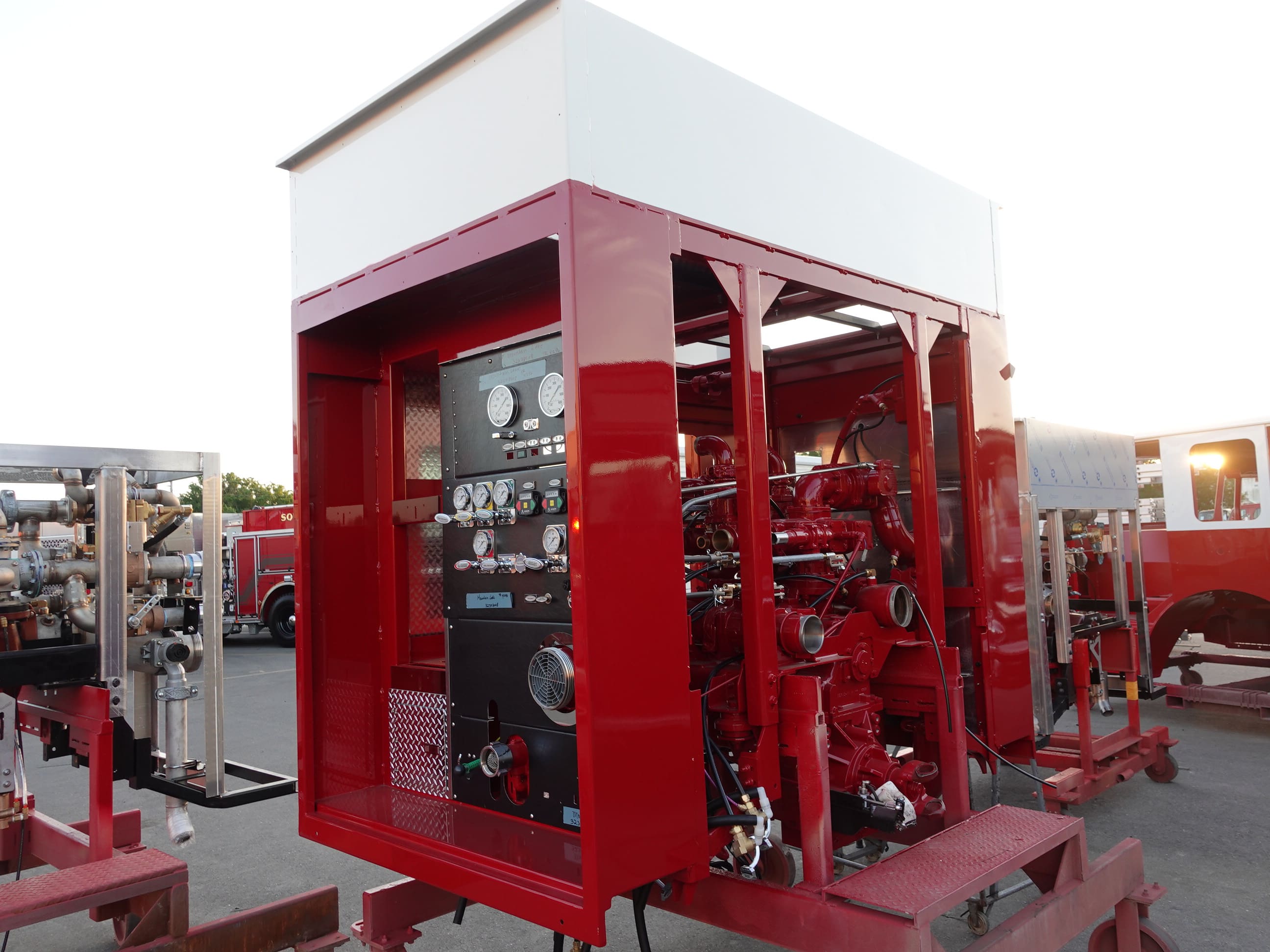

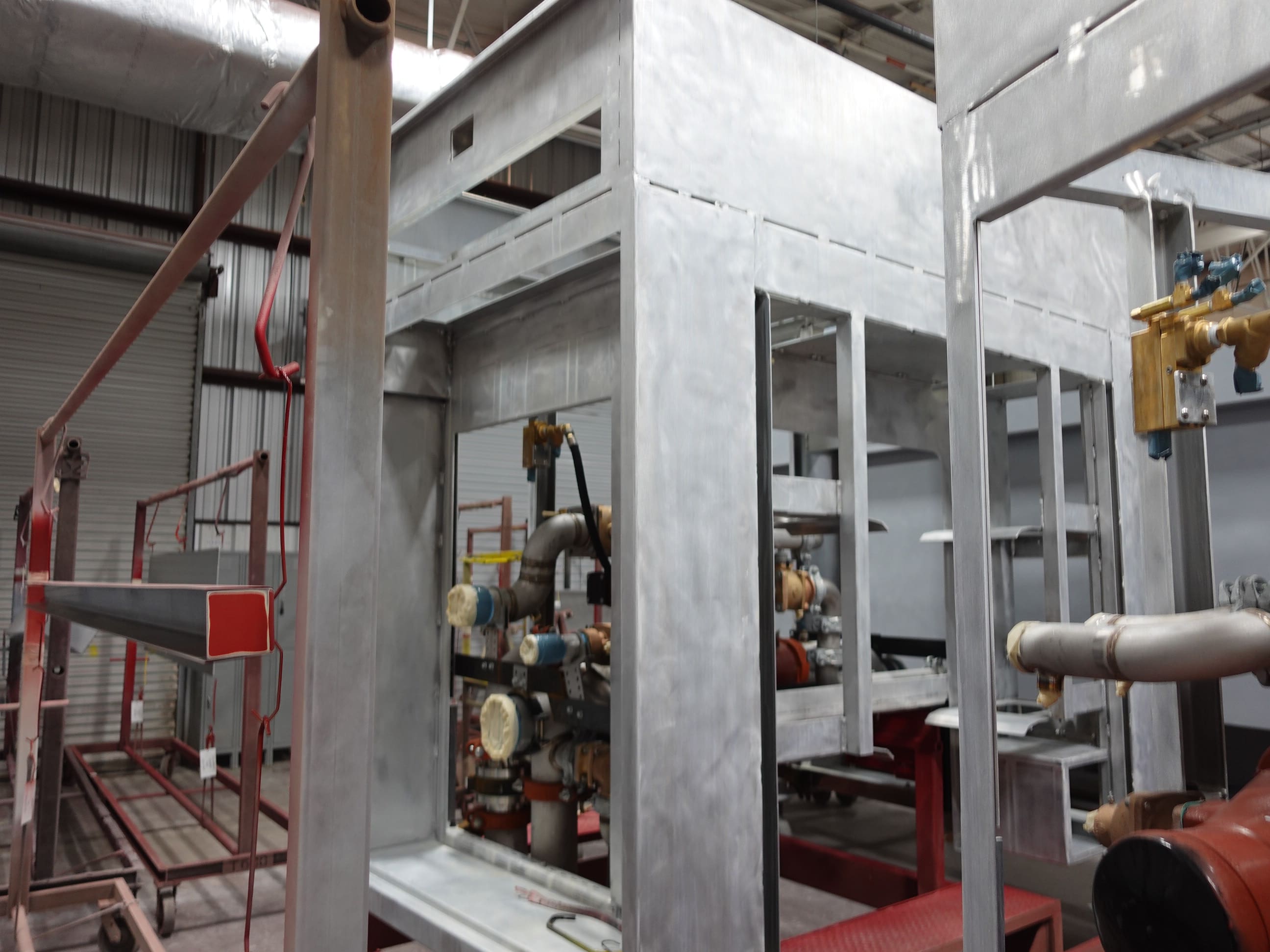

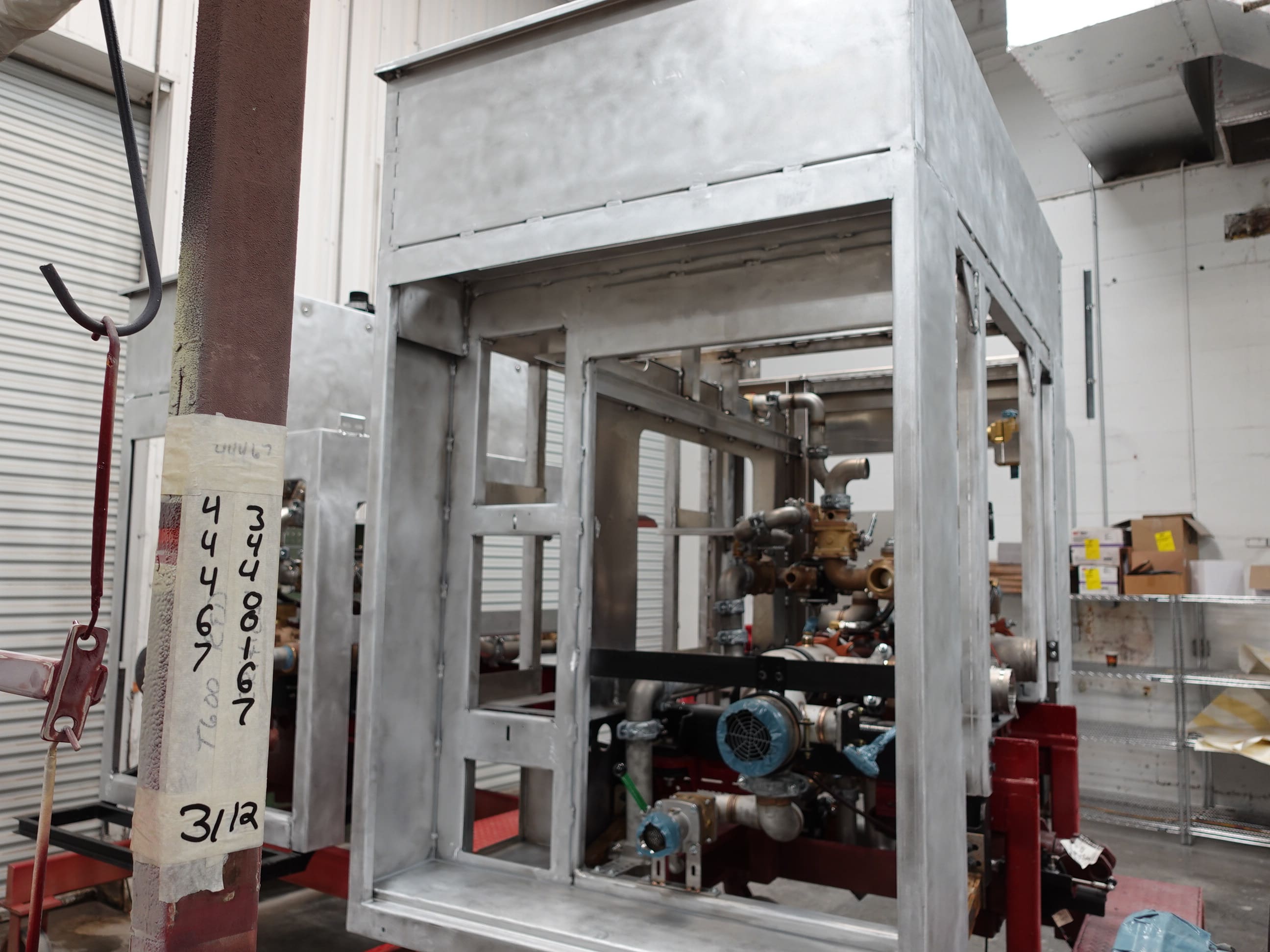

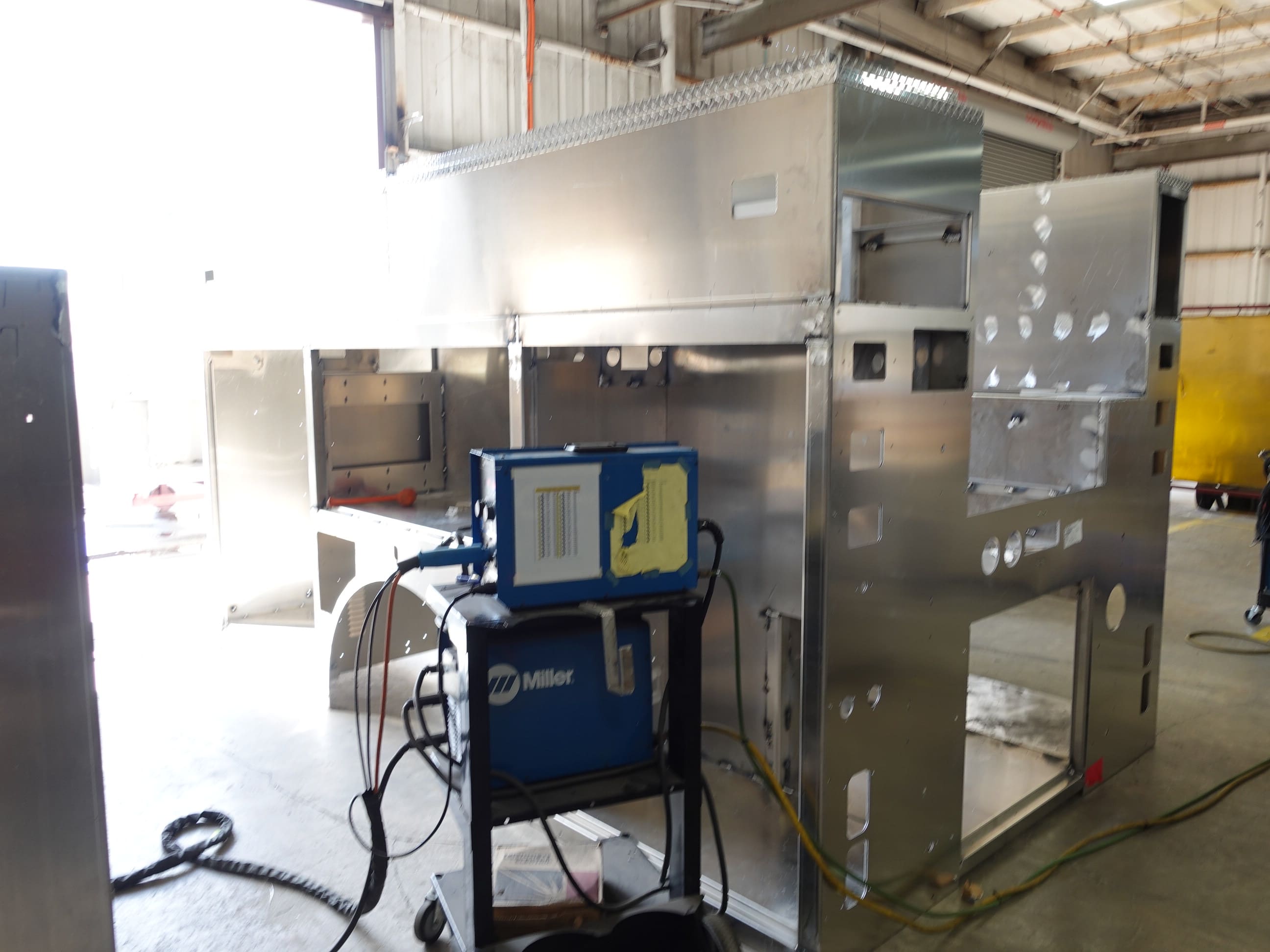

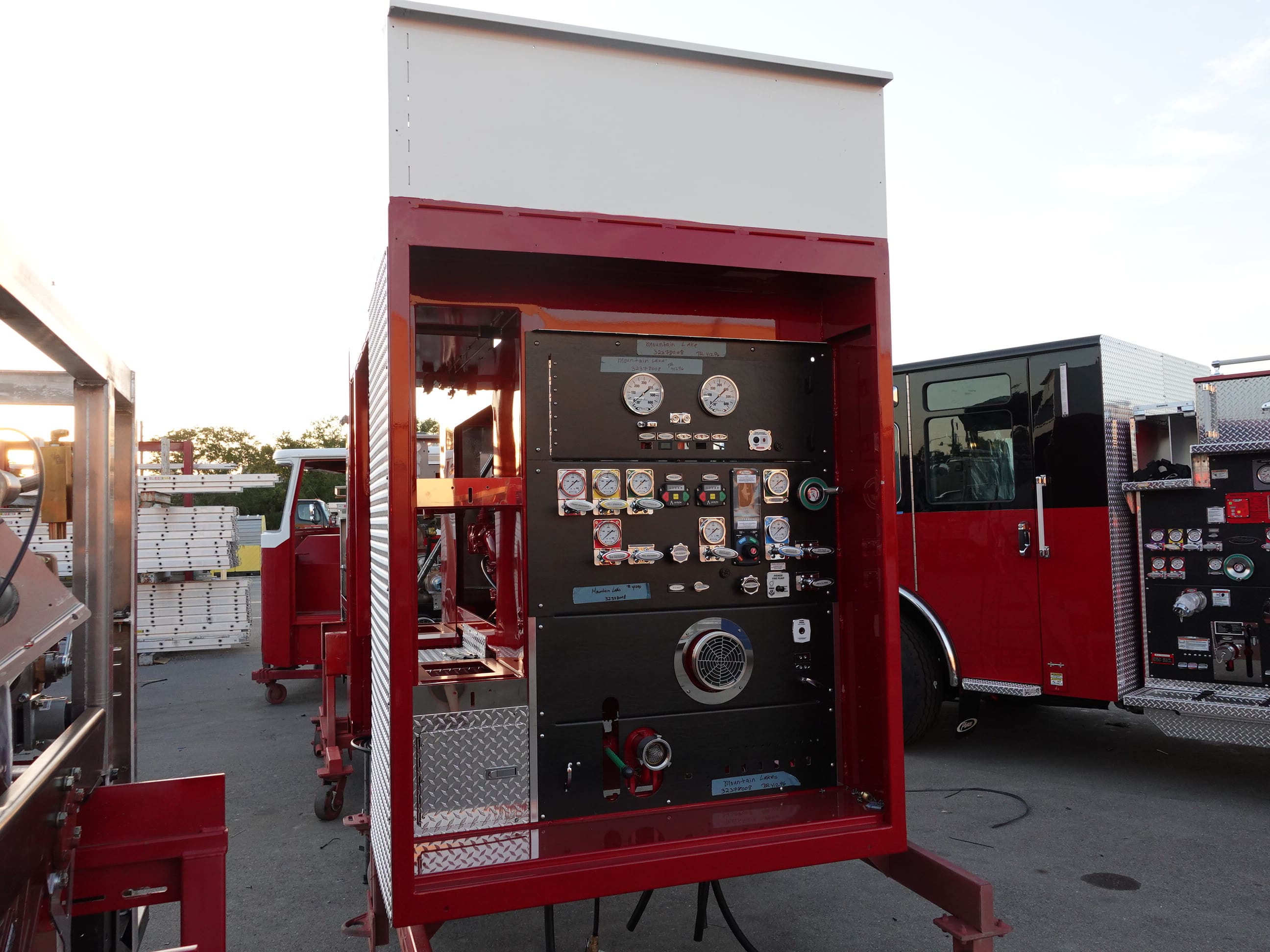

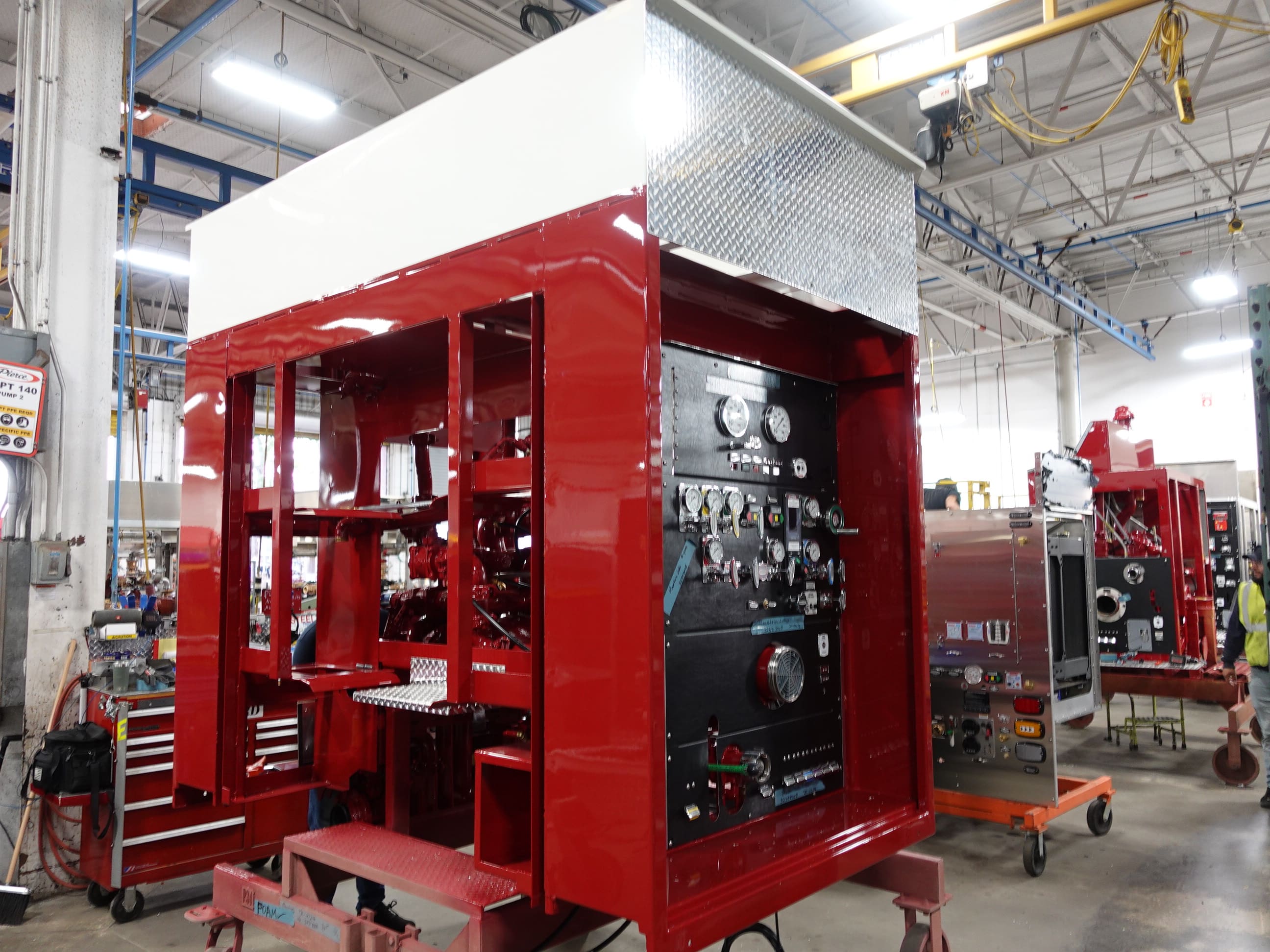

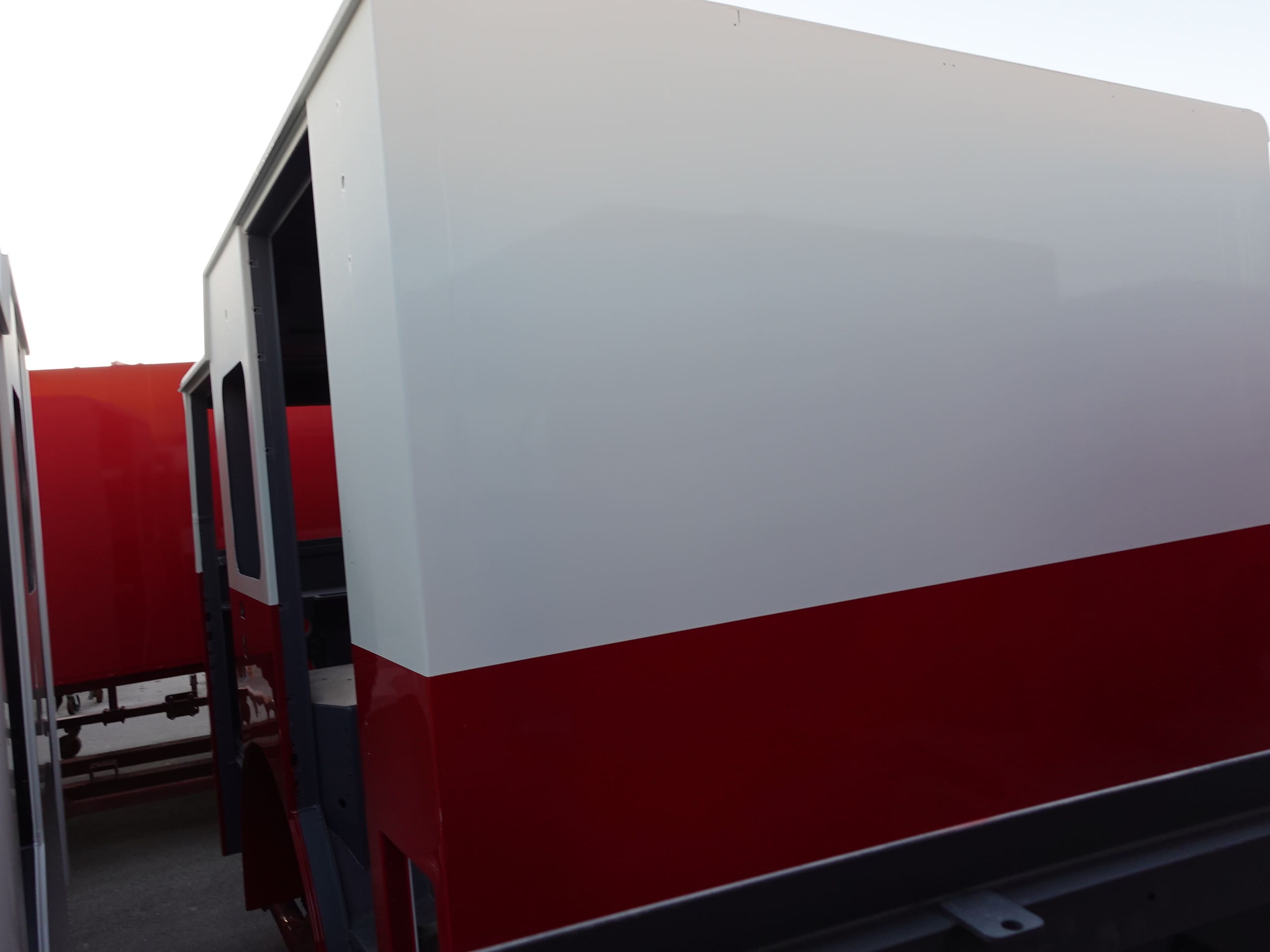

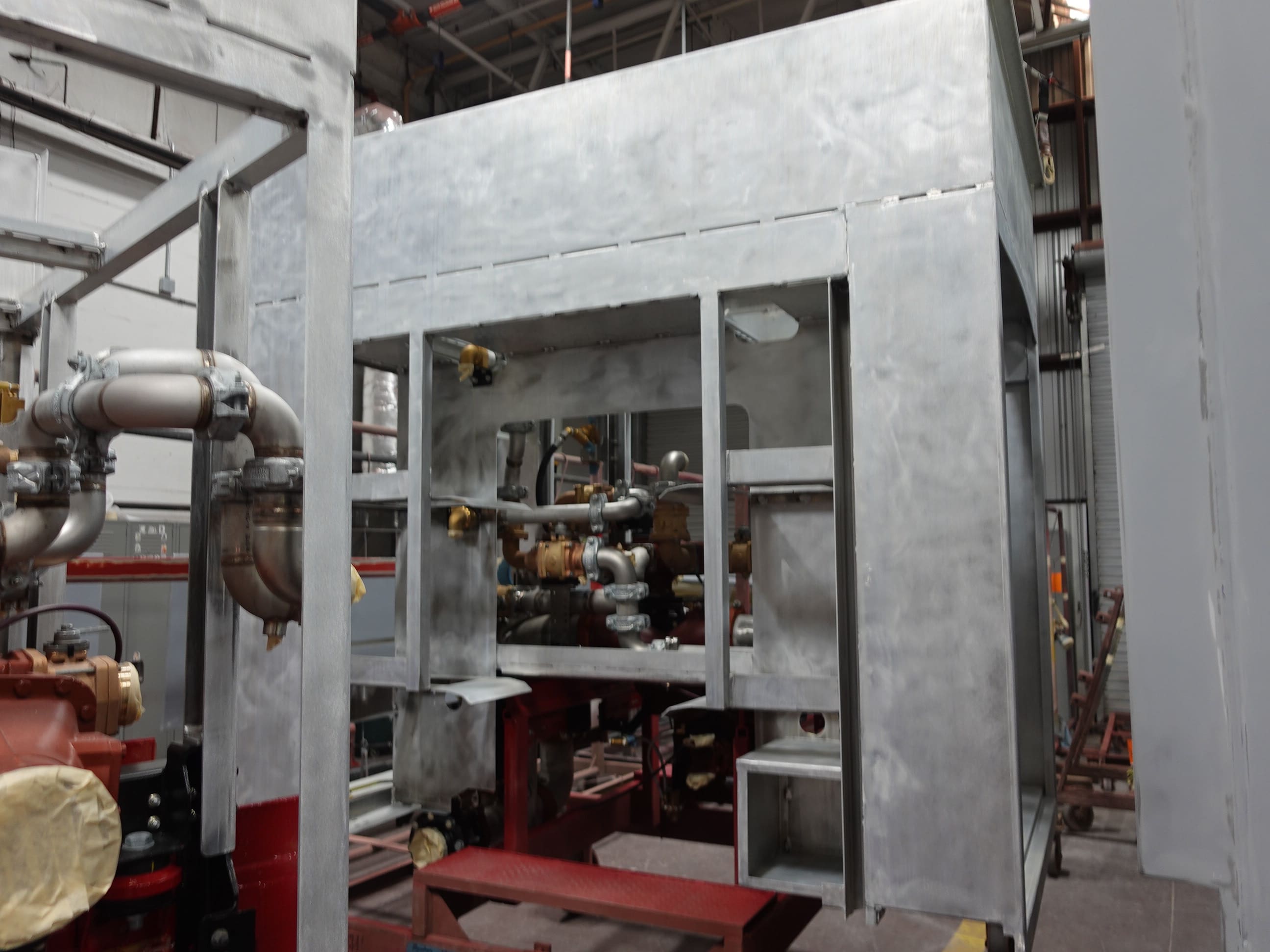

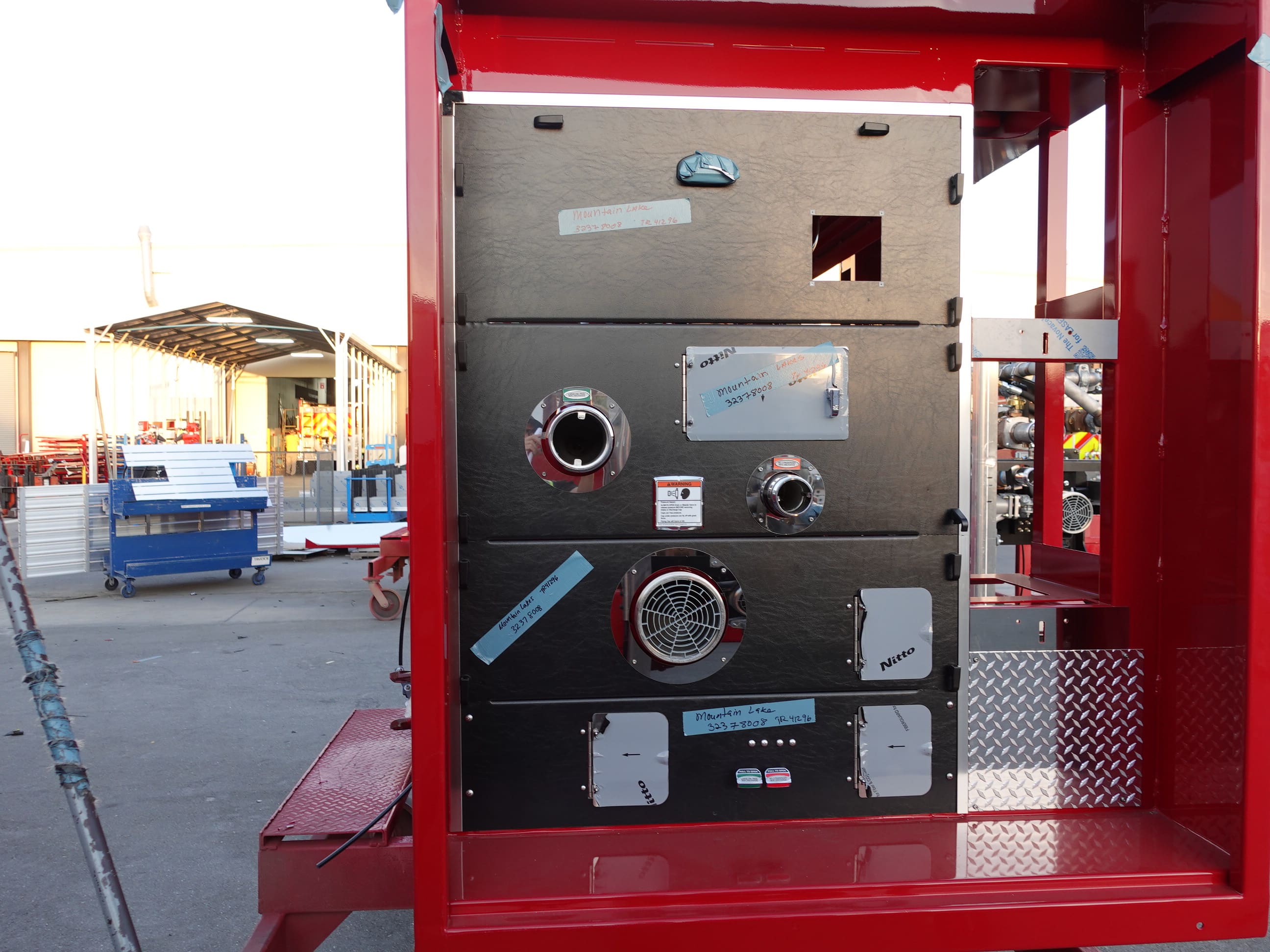

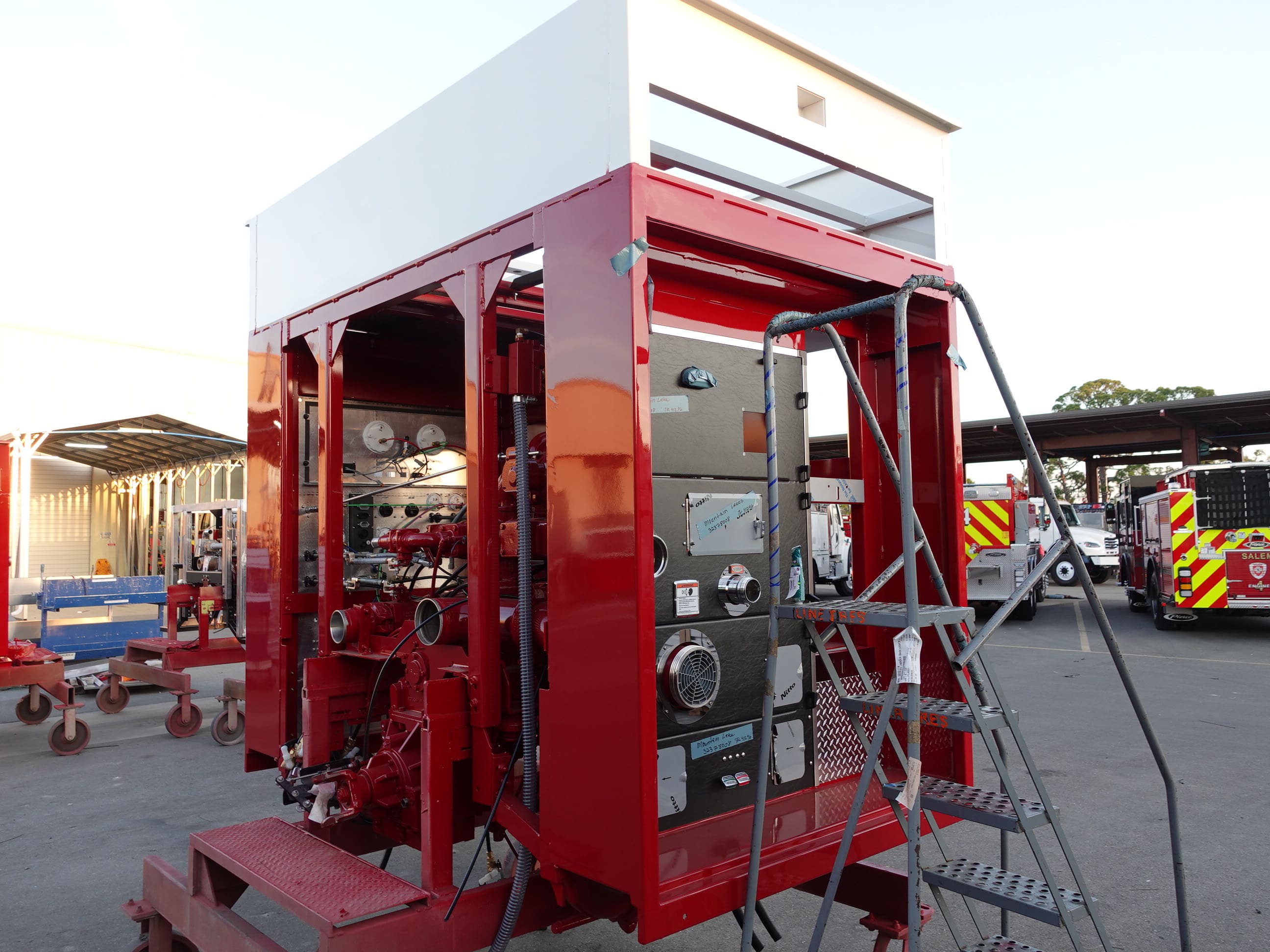

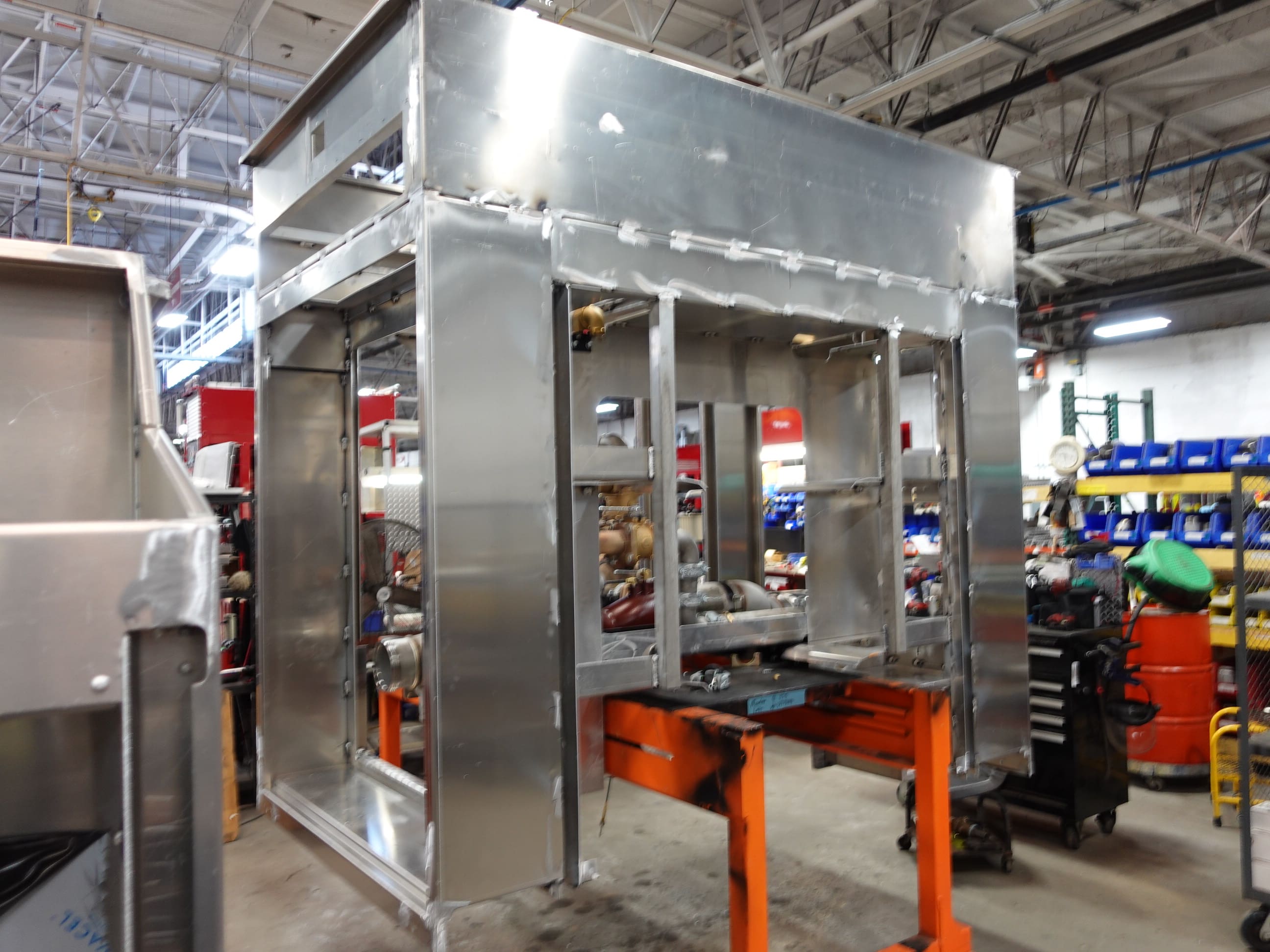

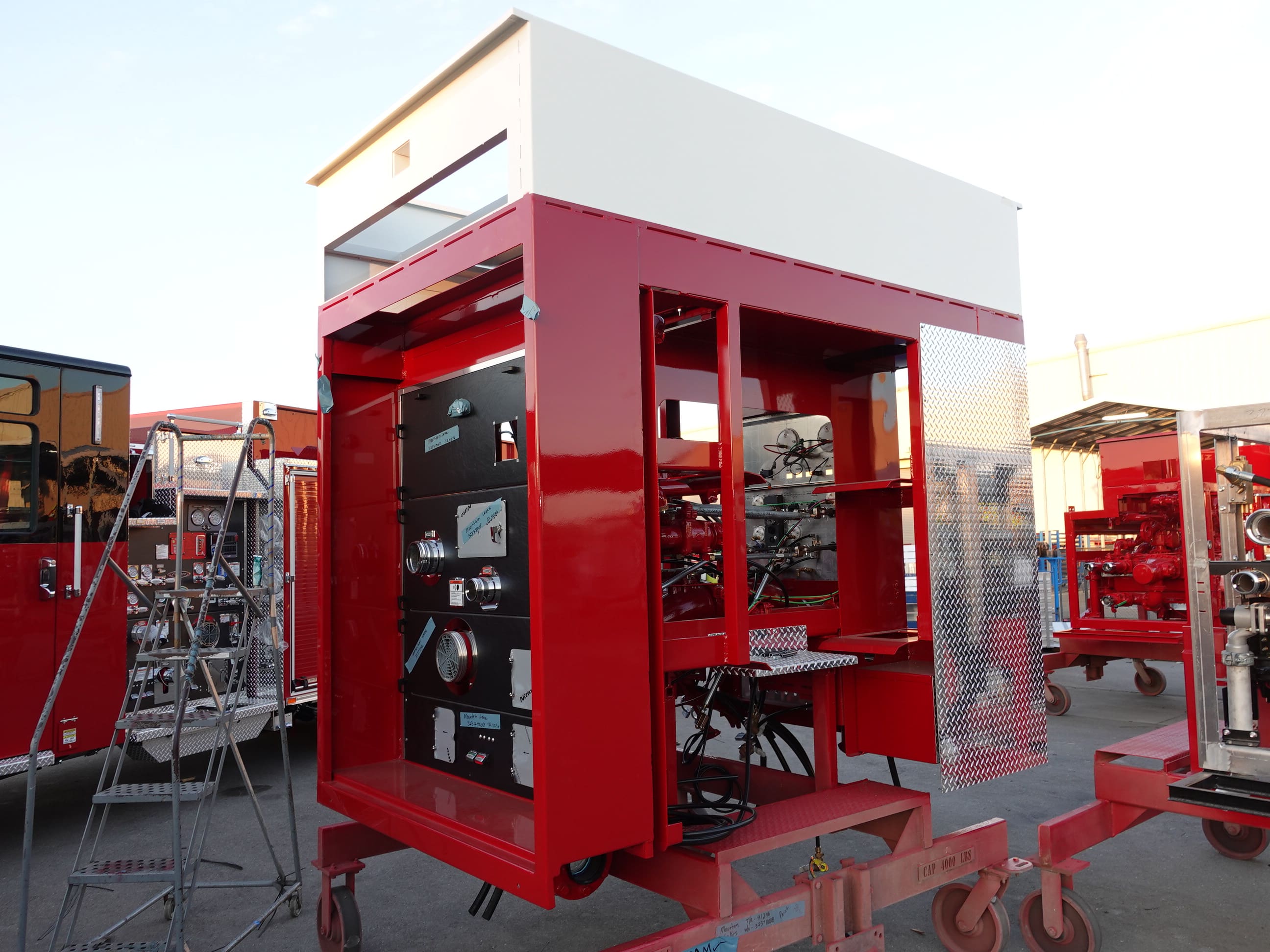

In this report, the pump house was merged with the chassis while the body remained staged.

04-24-26

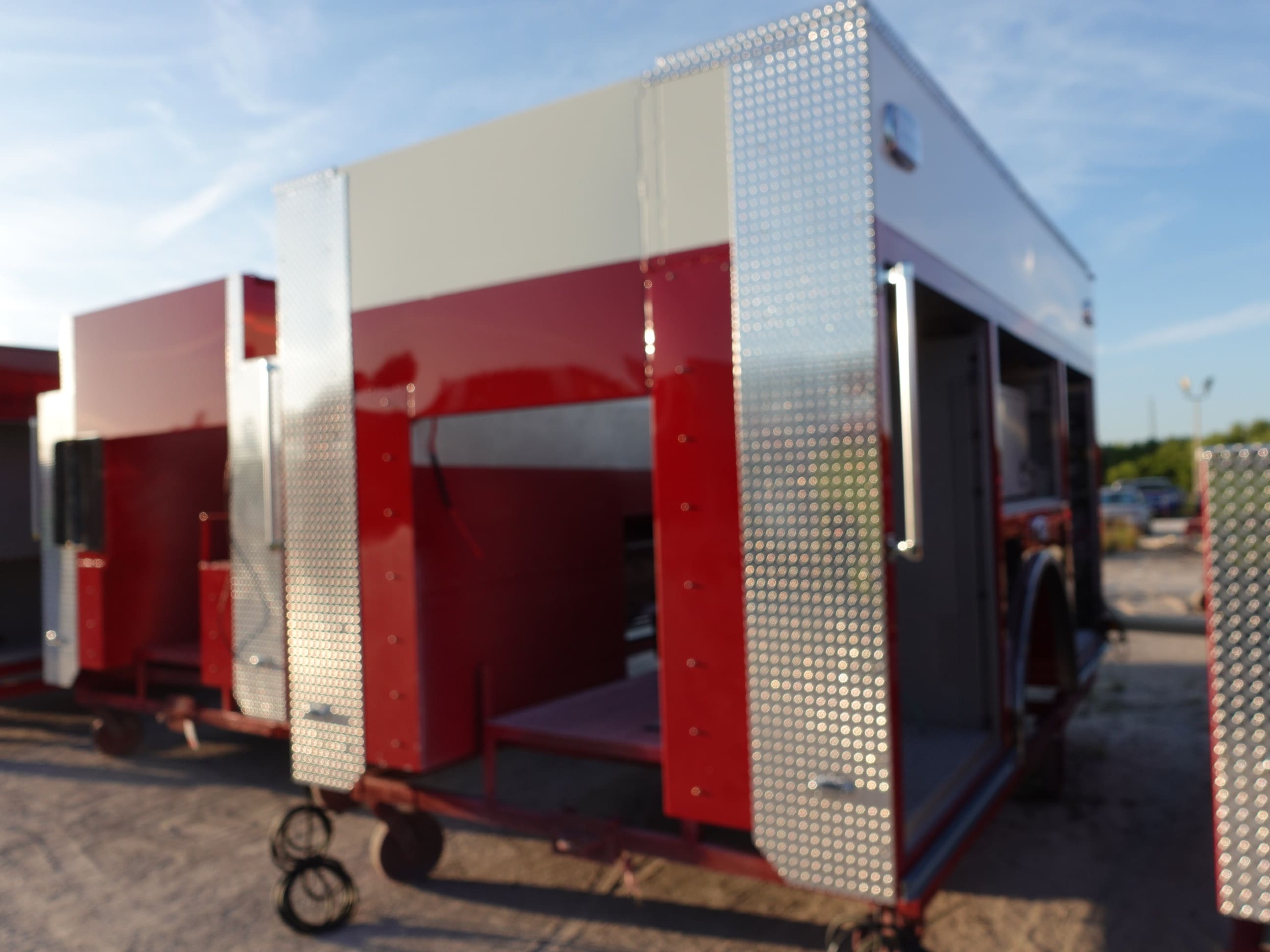

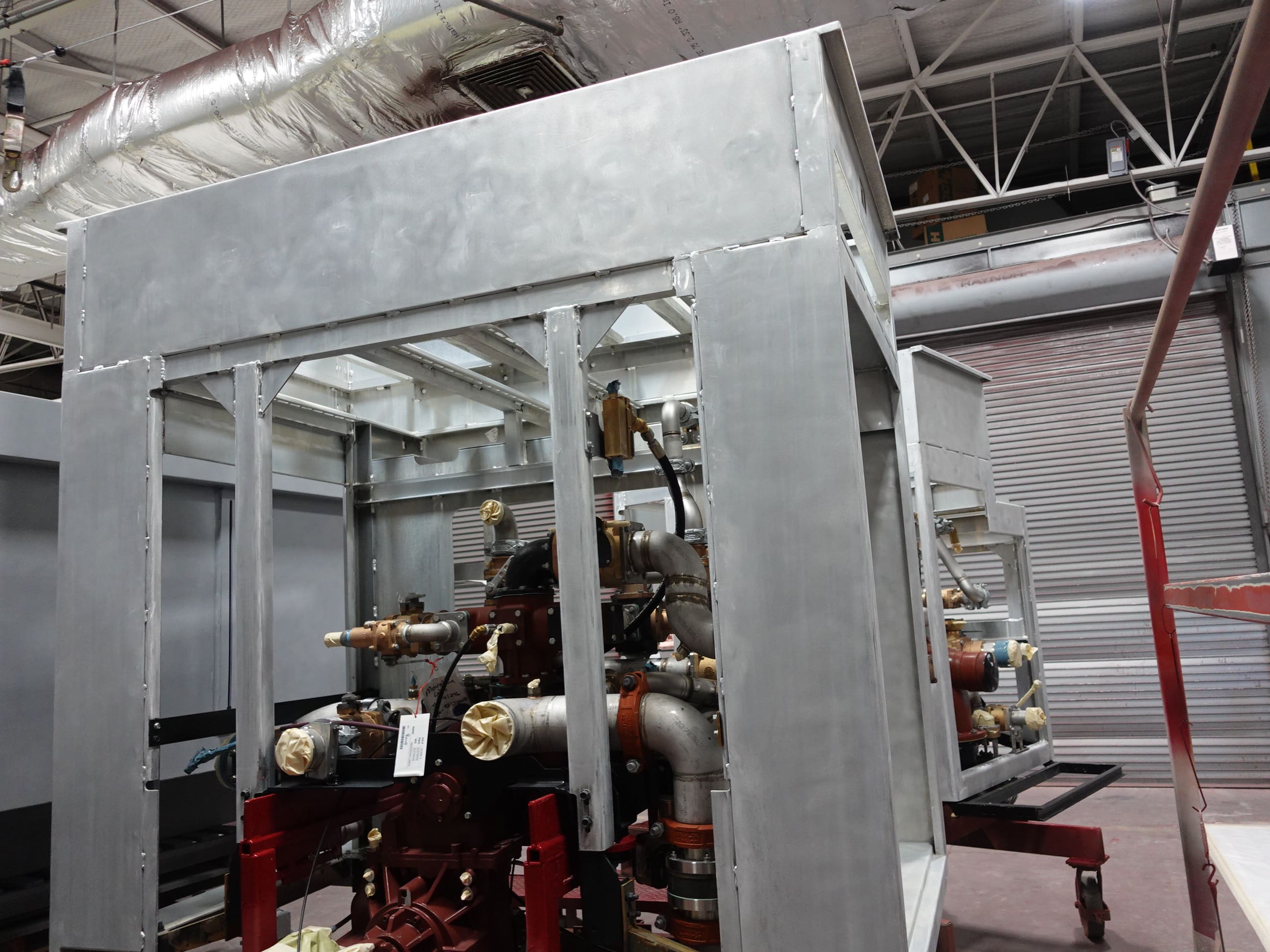

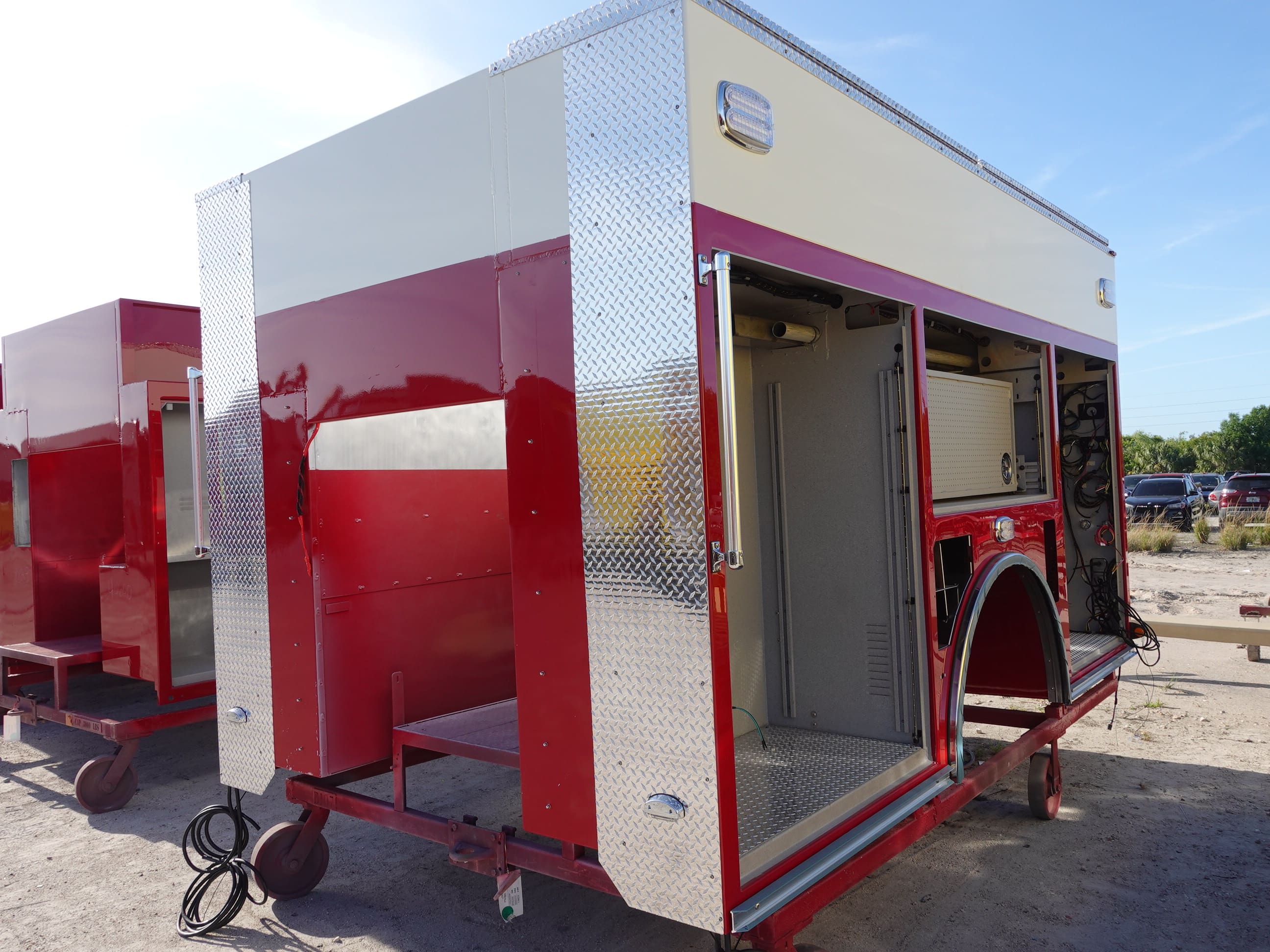

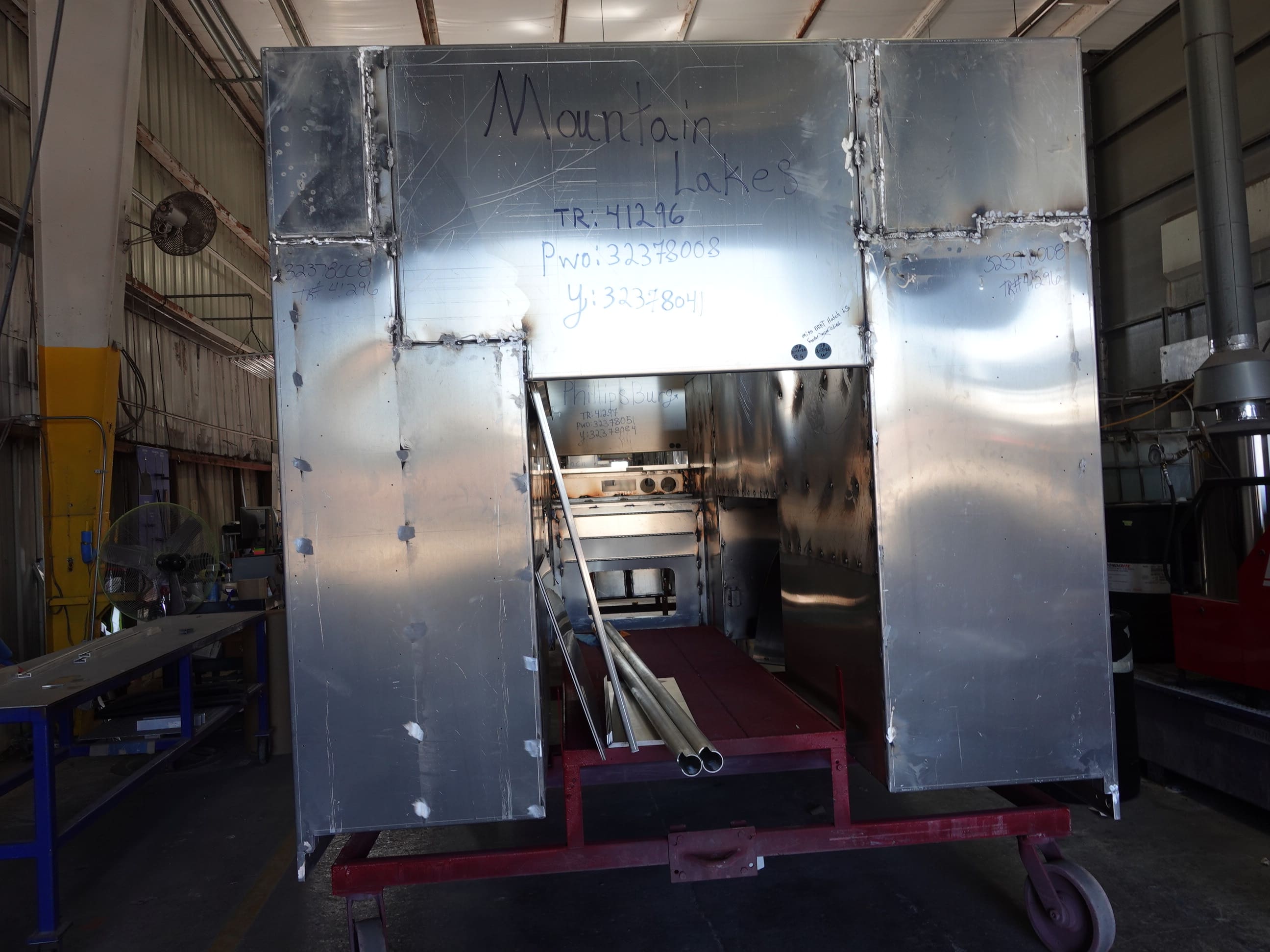

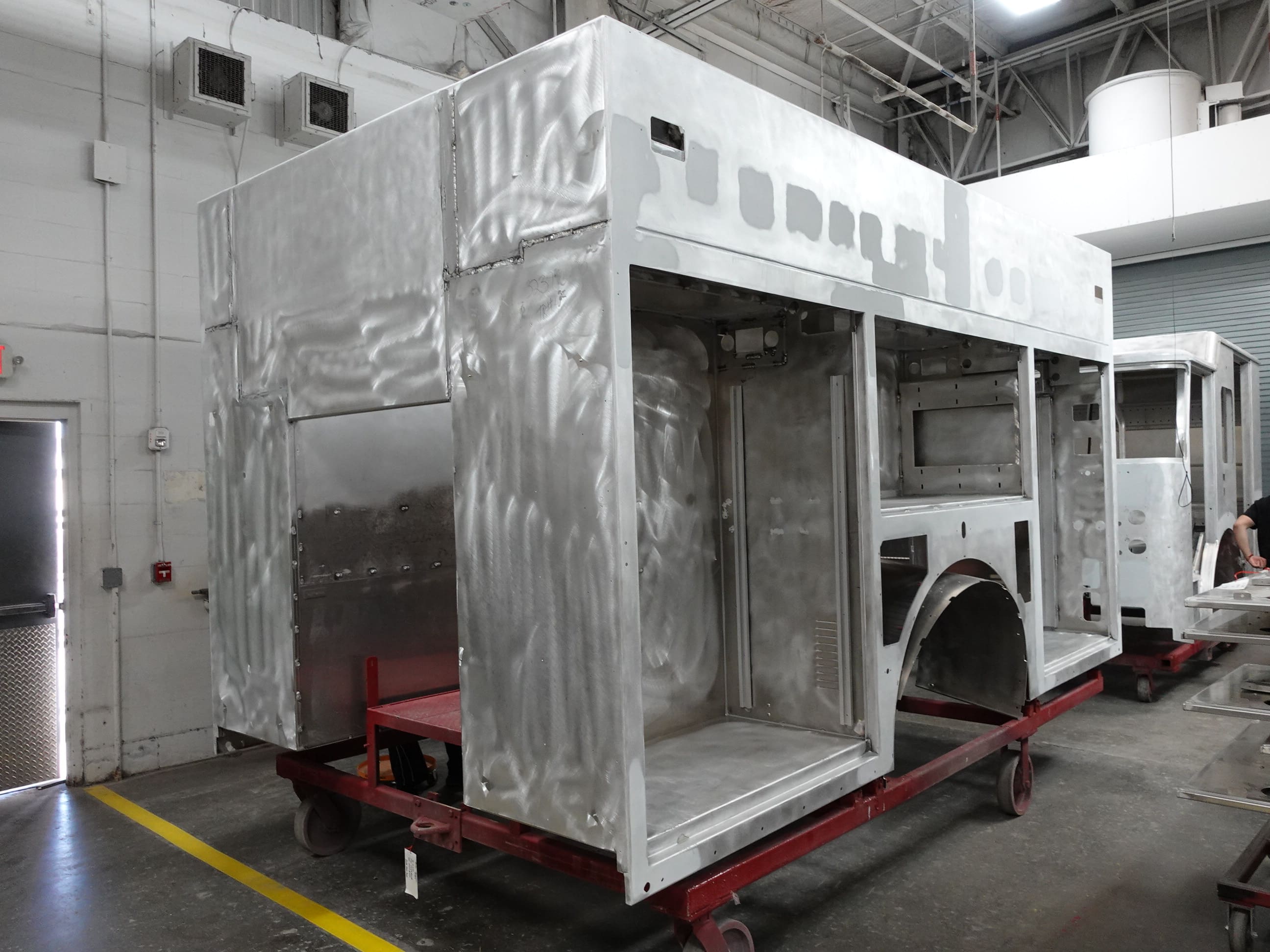

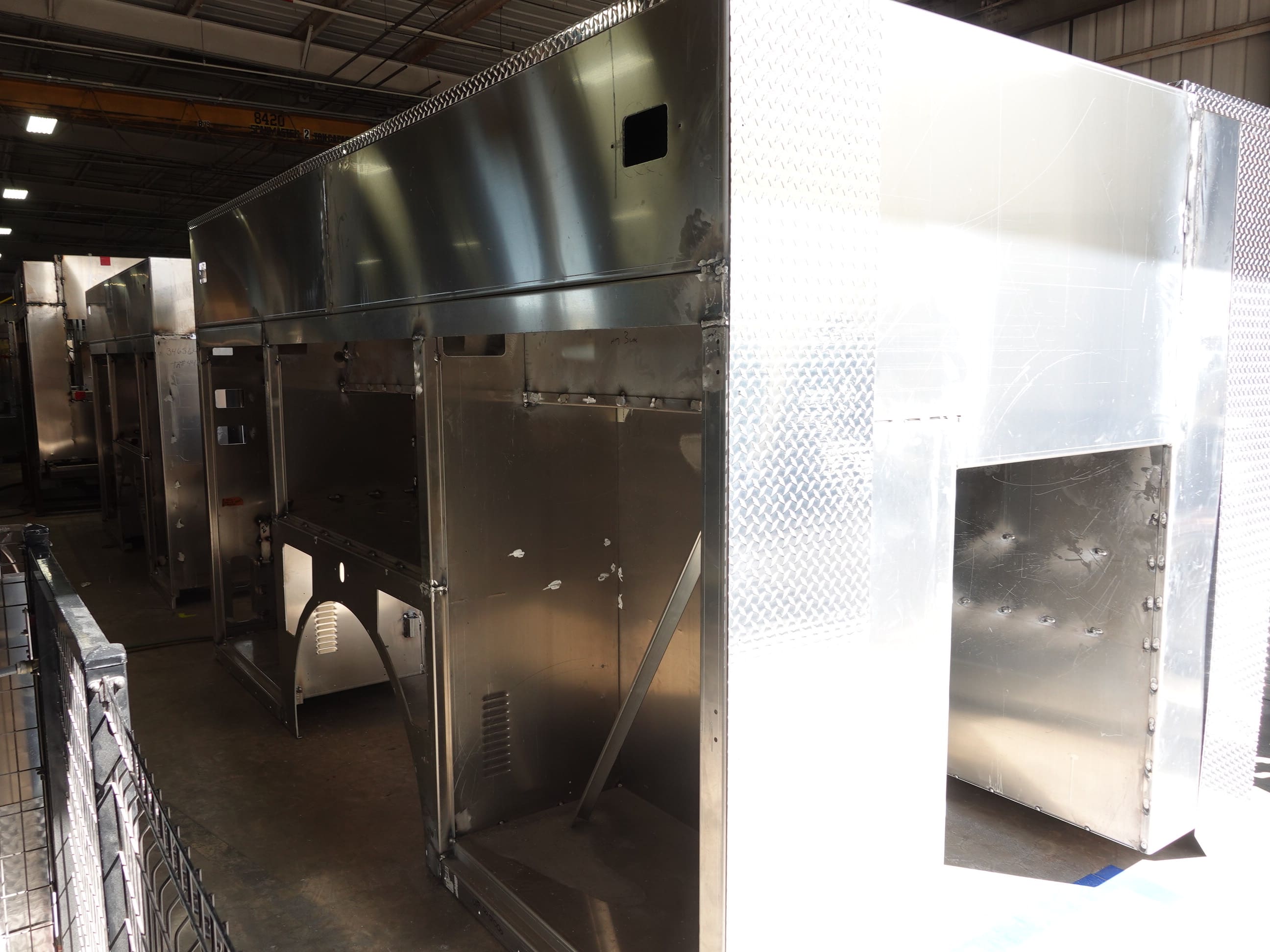

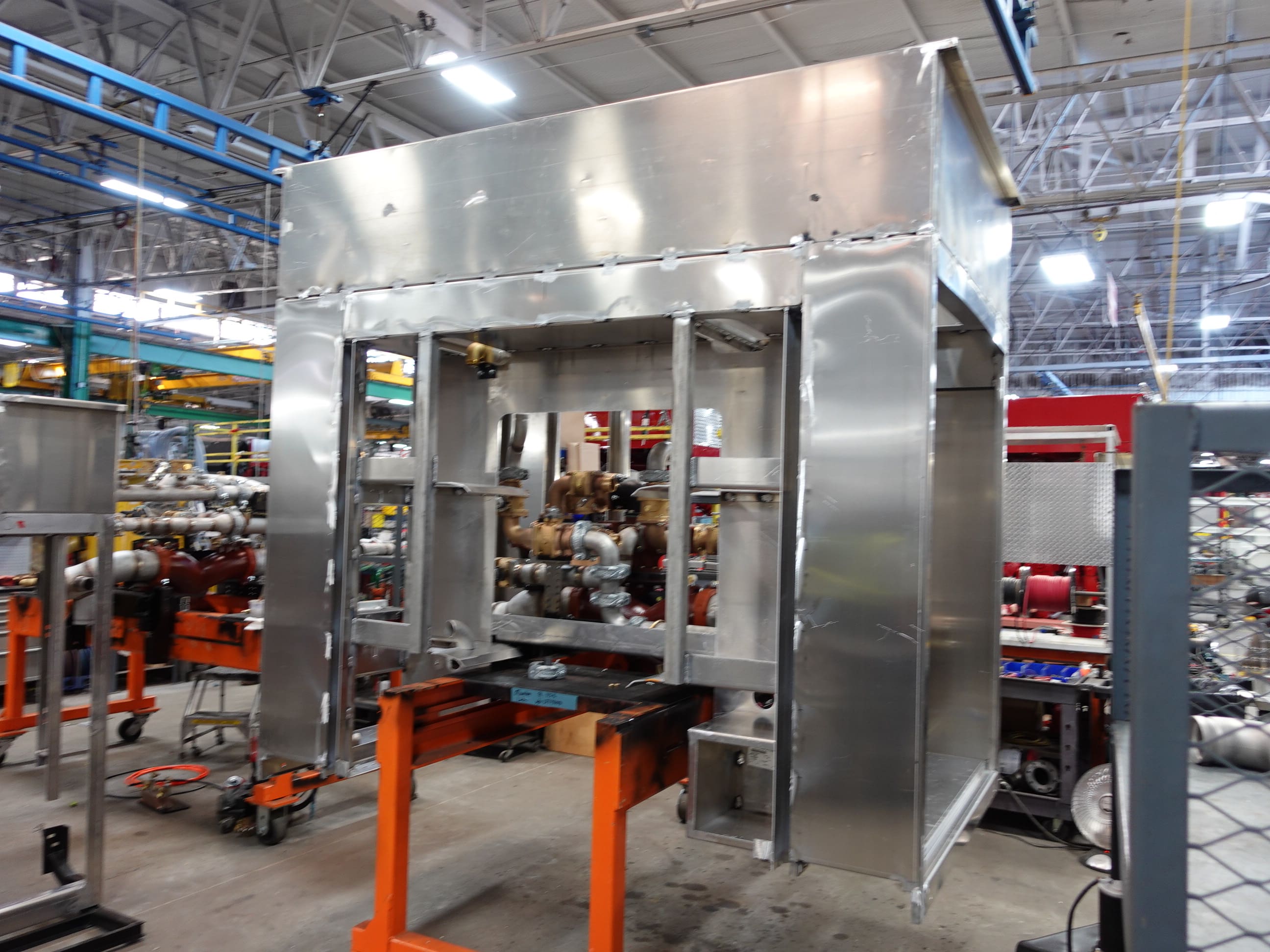

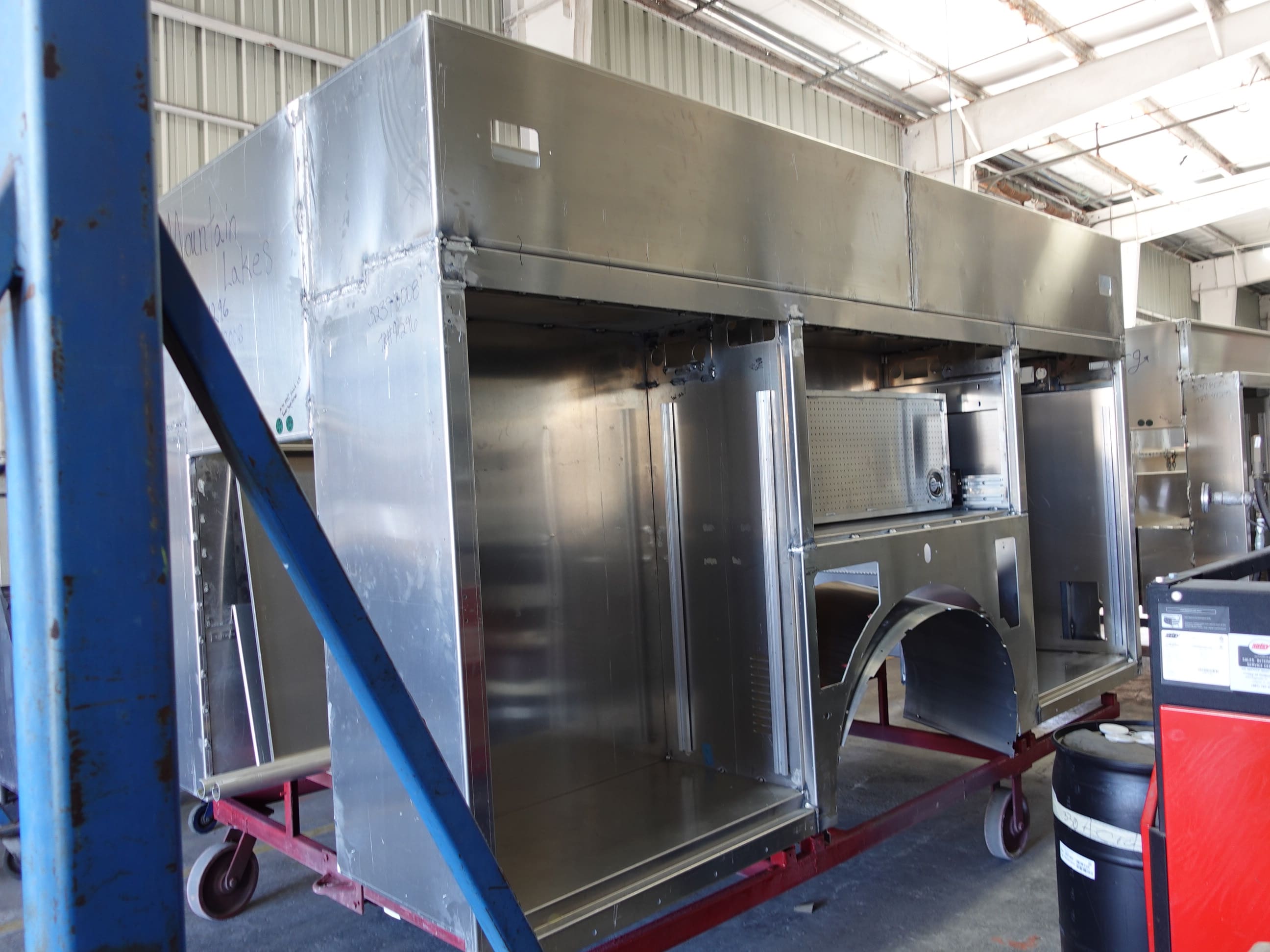

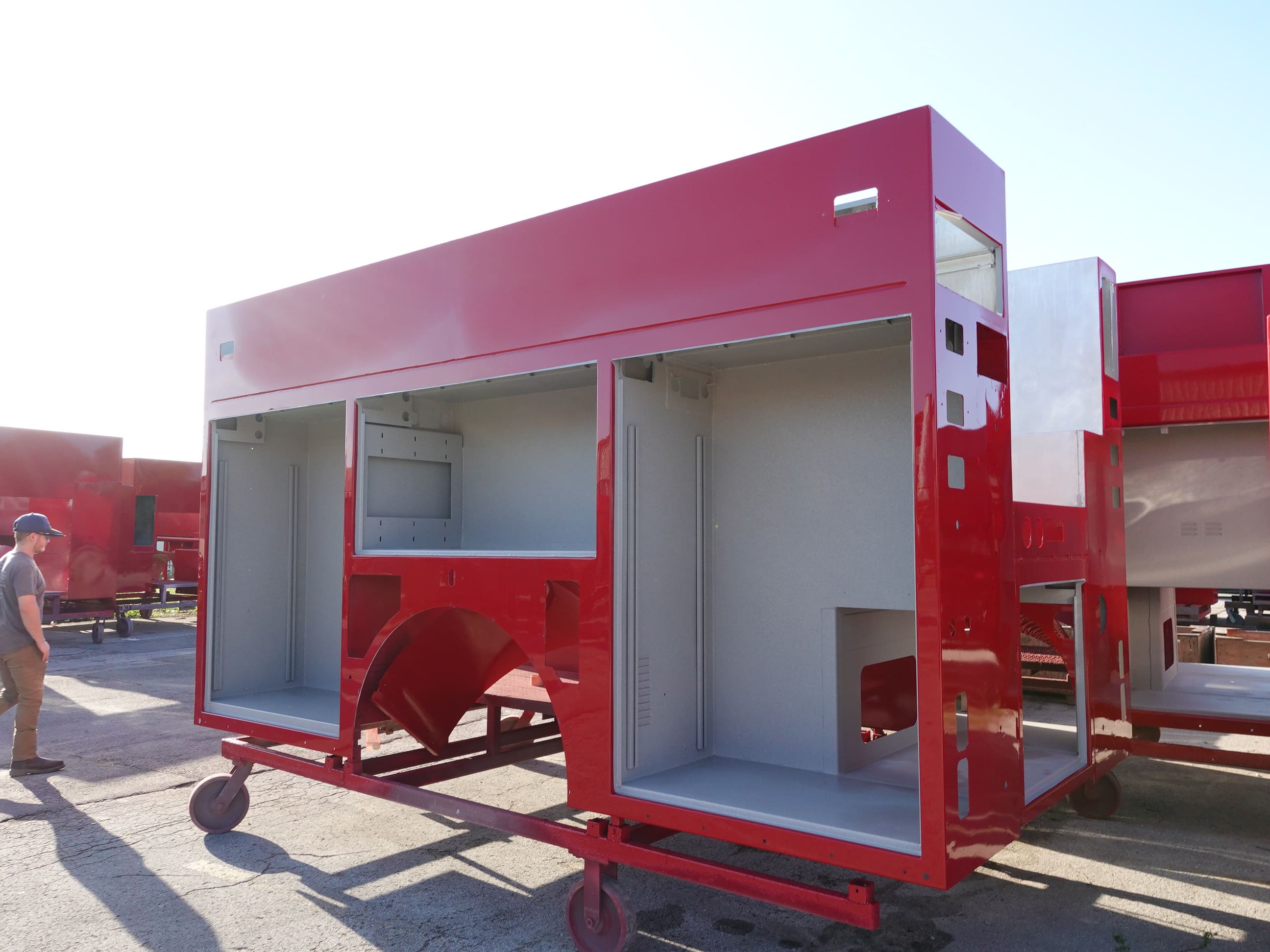

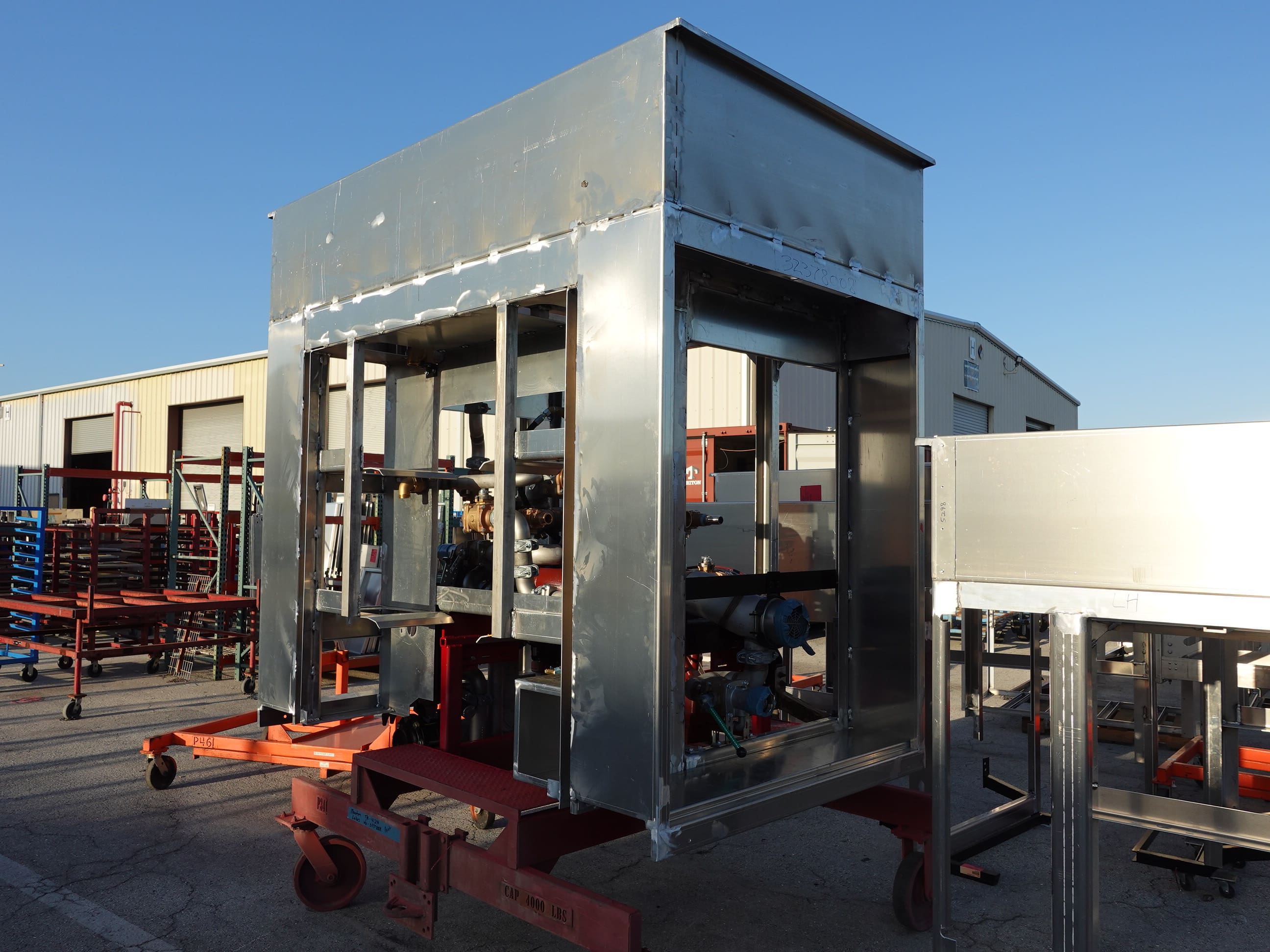

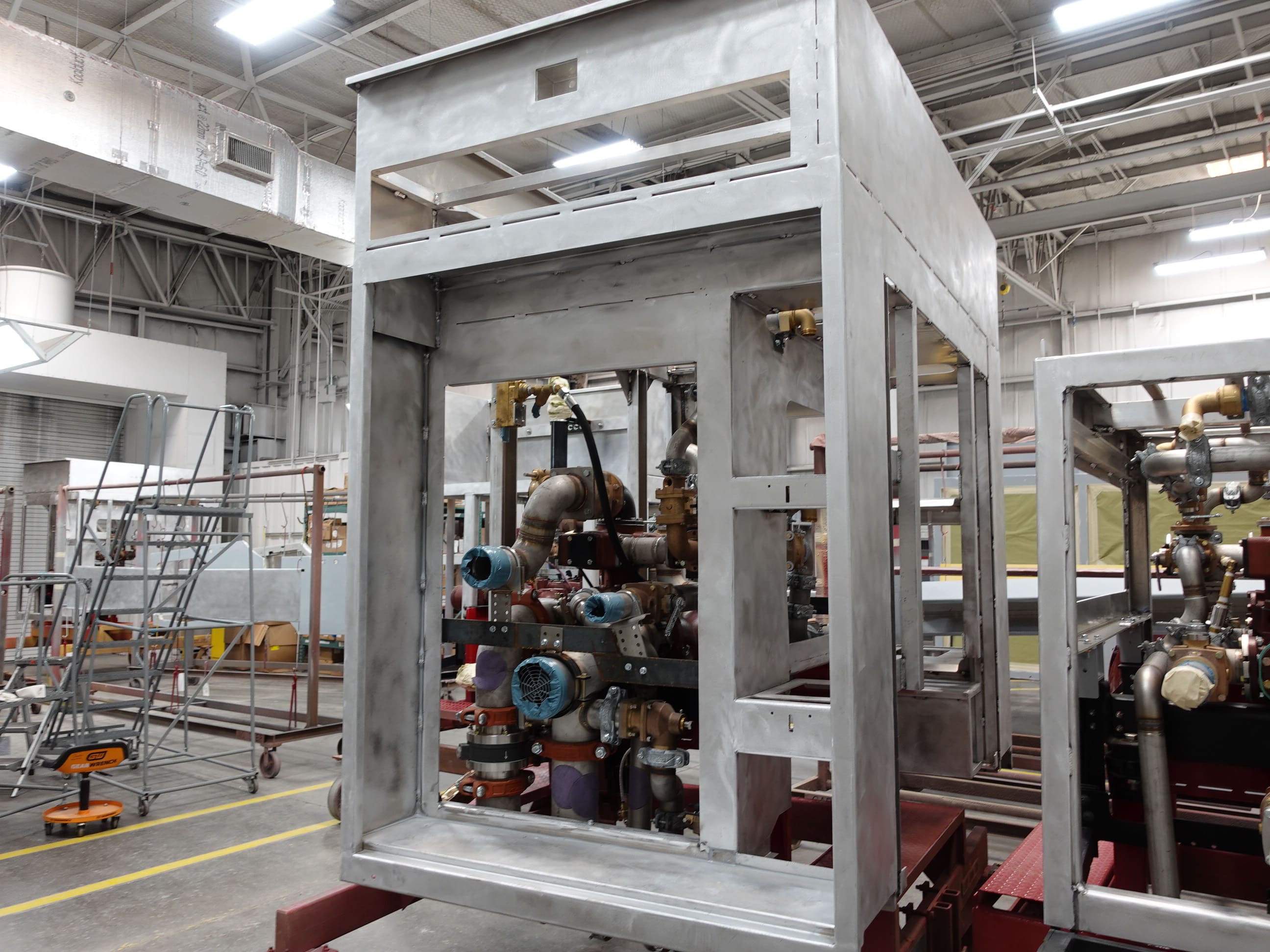

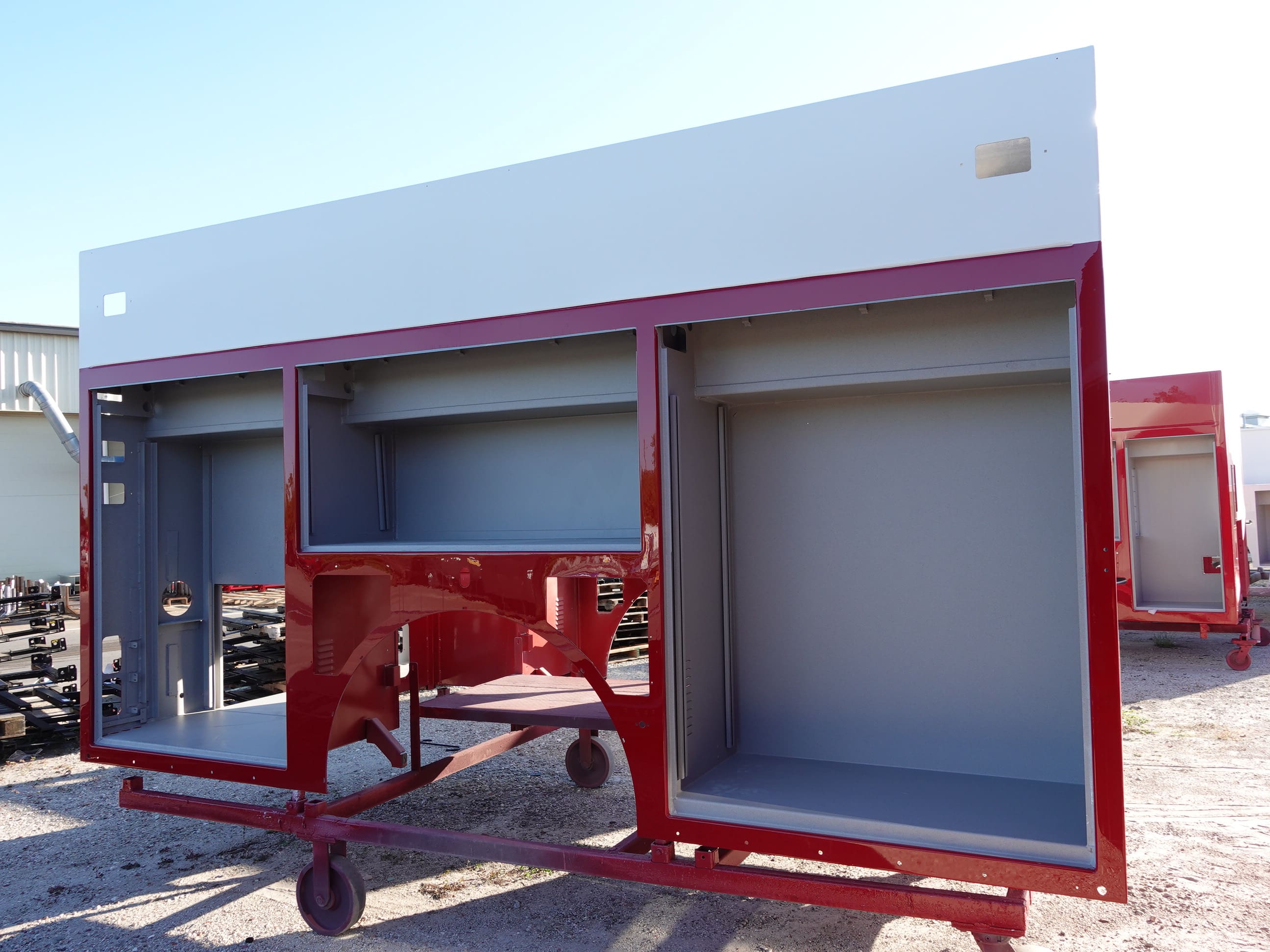

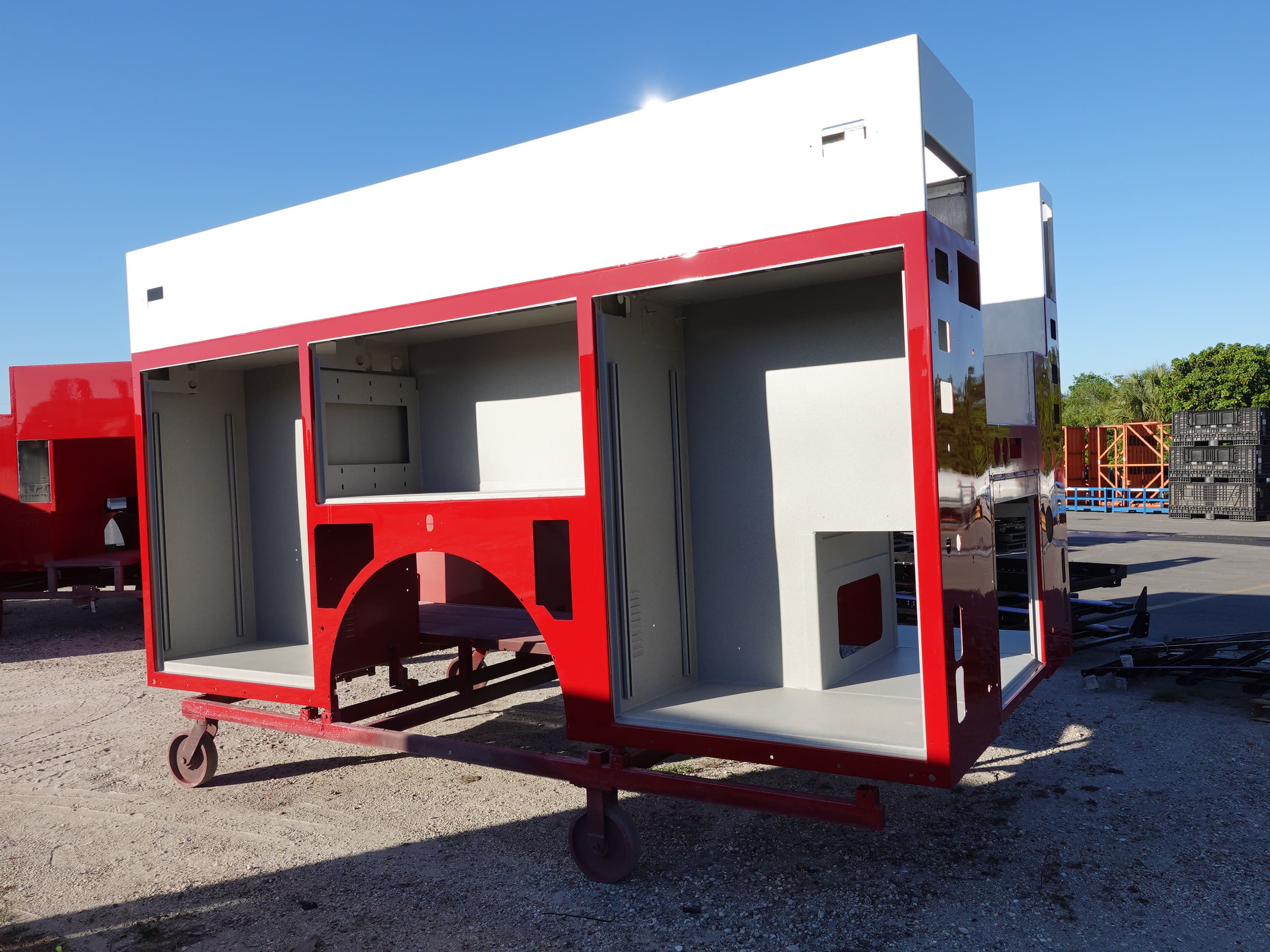

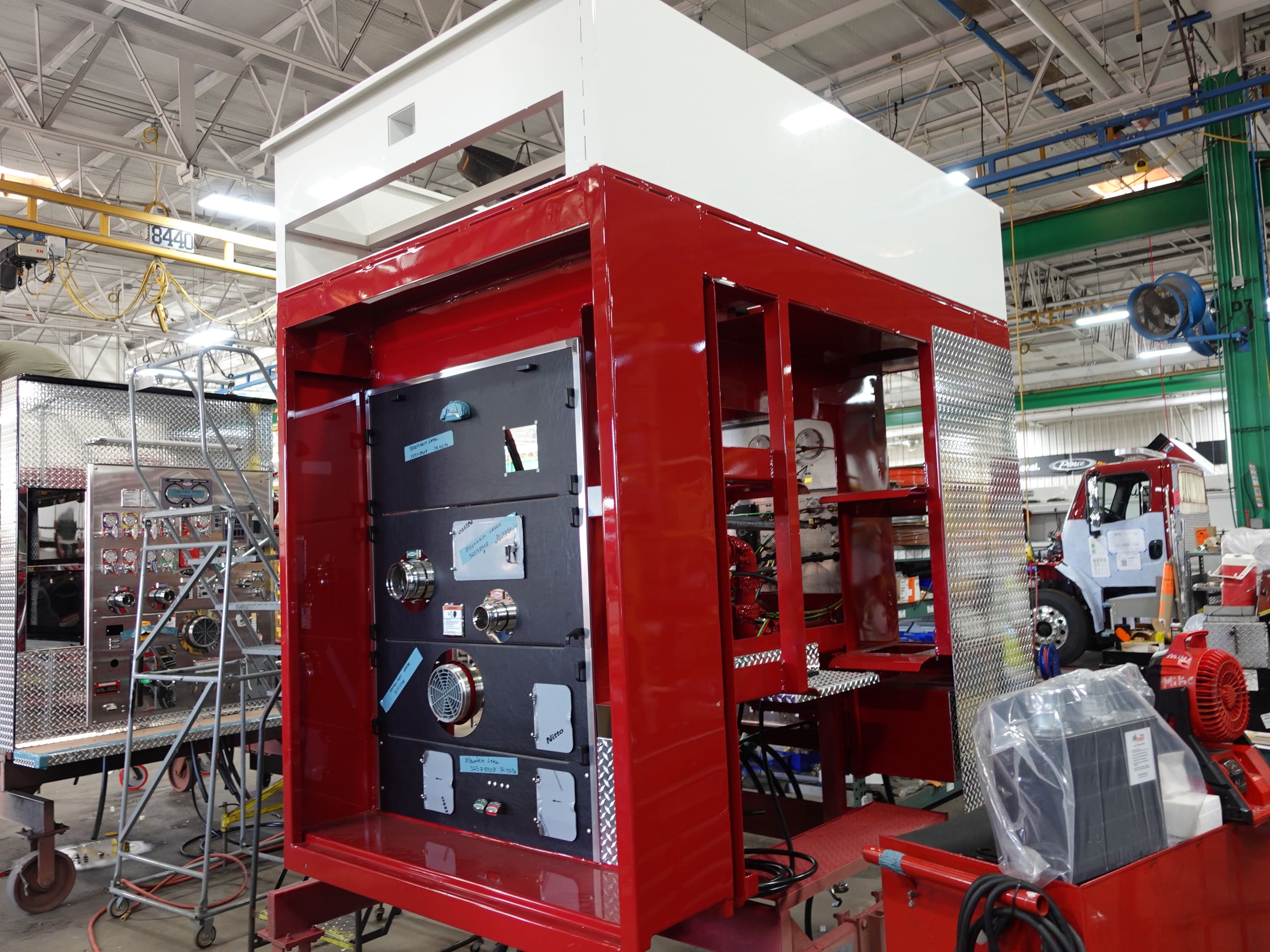

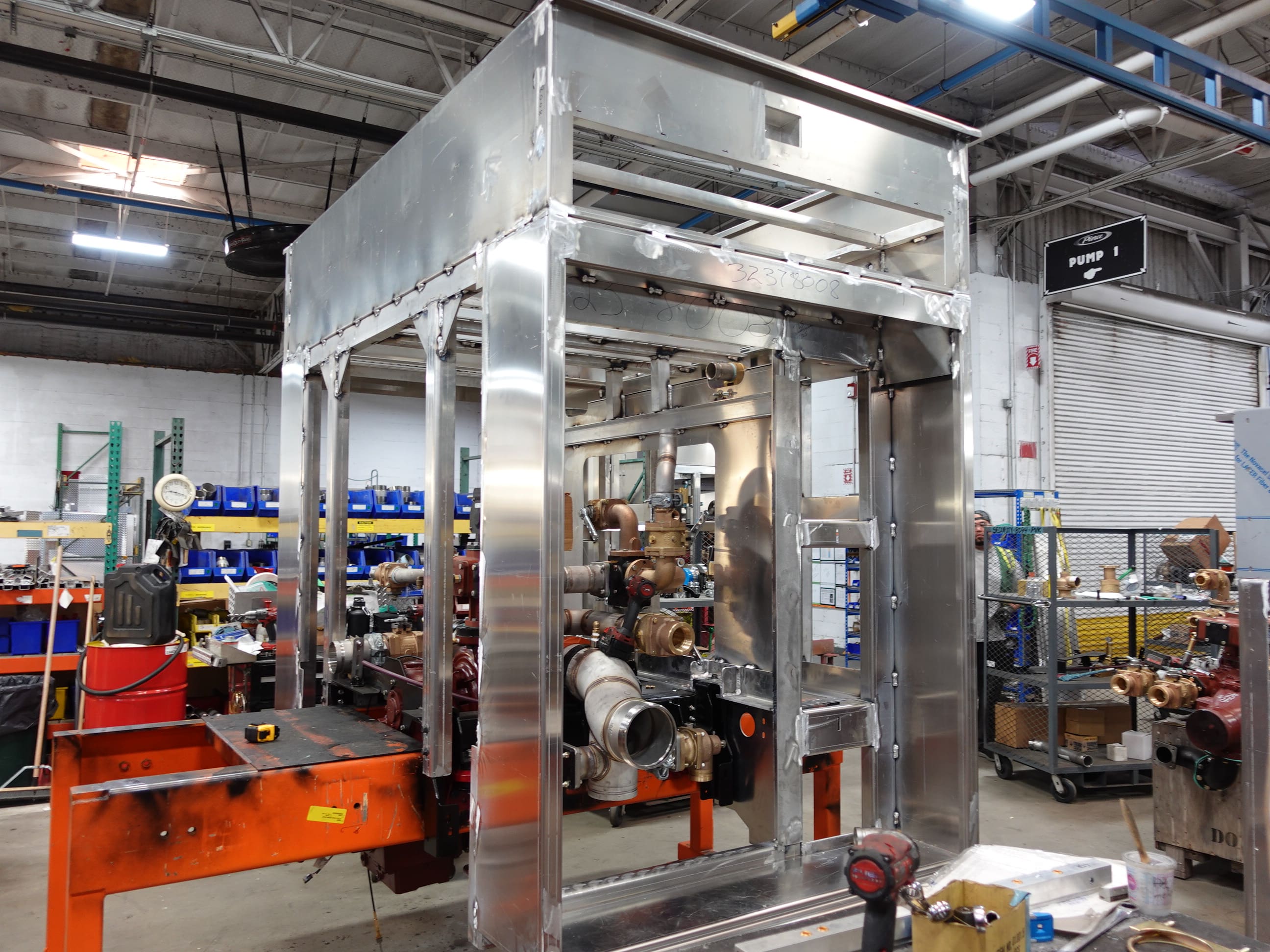

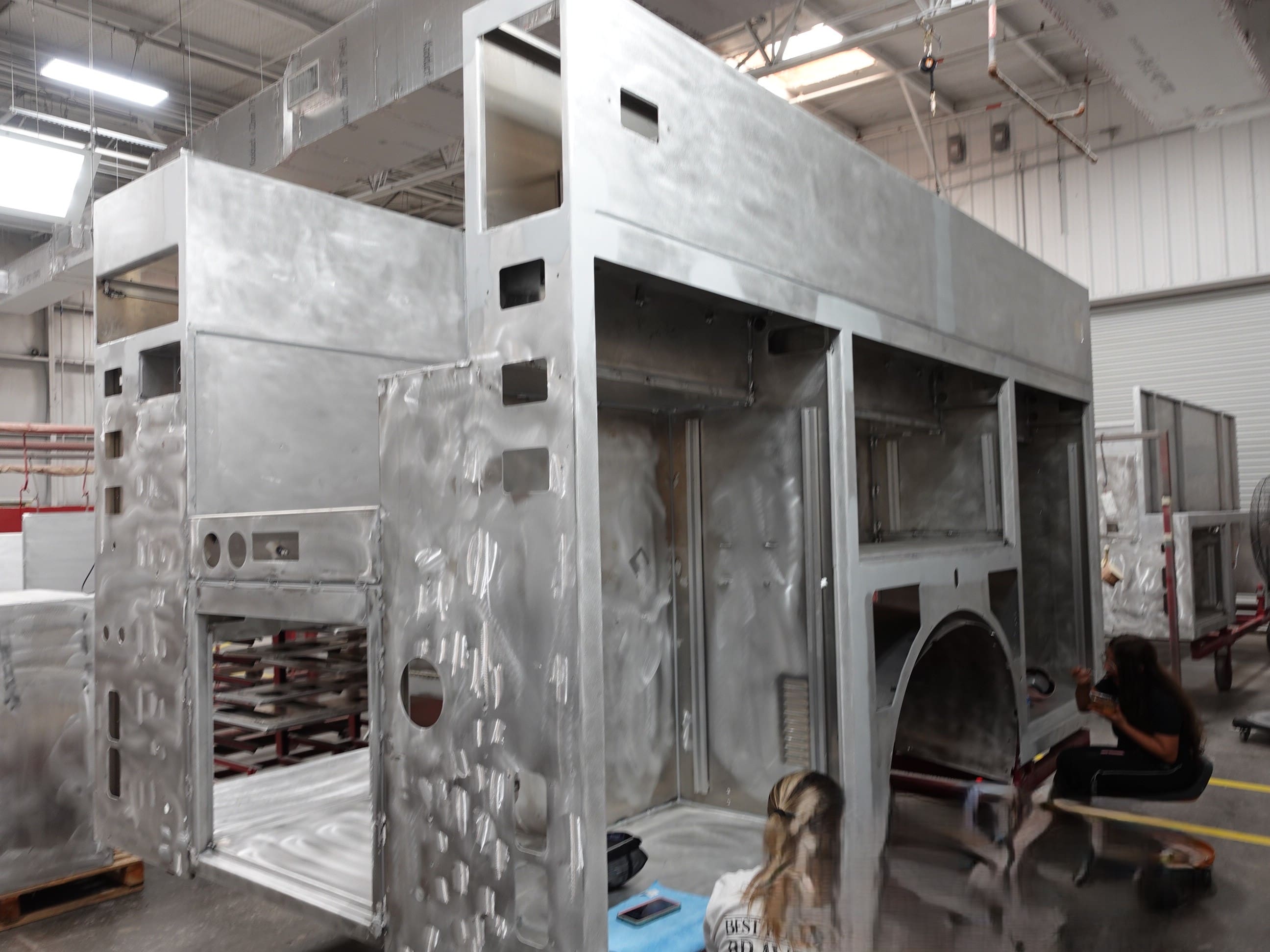

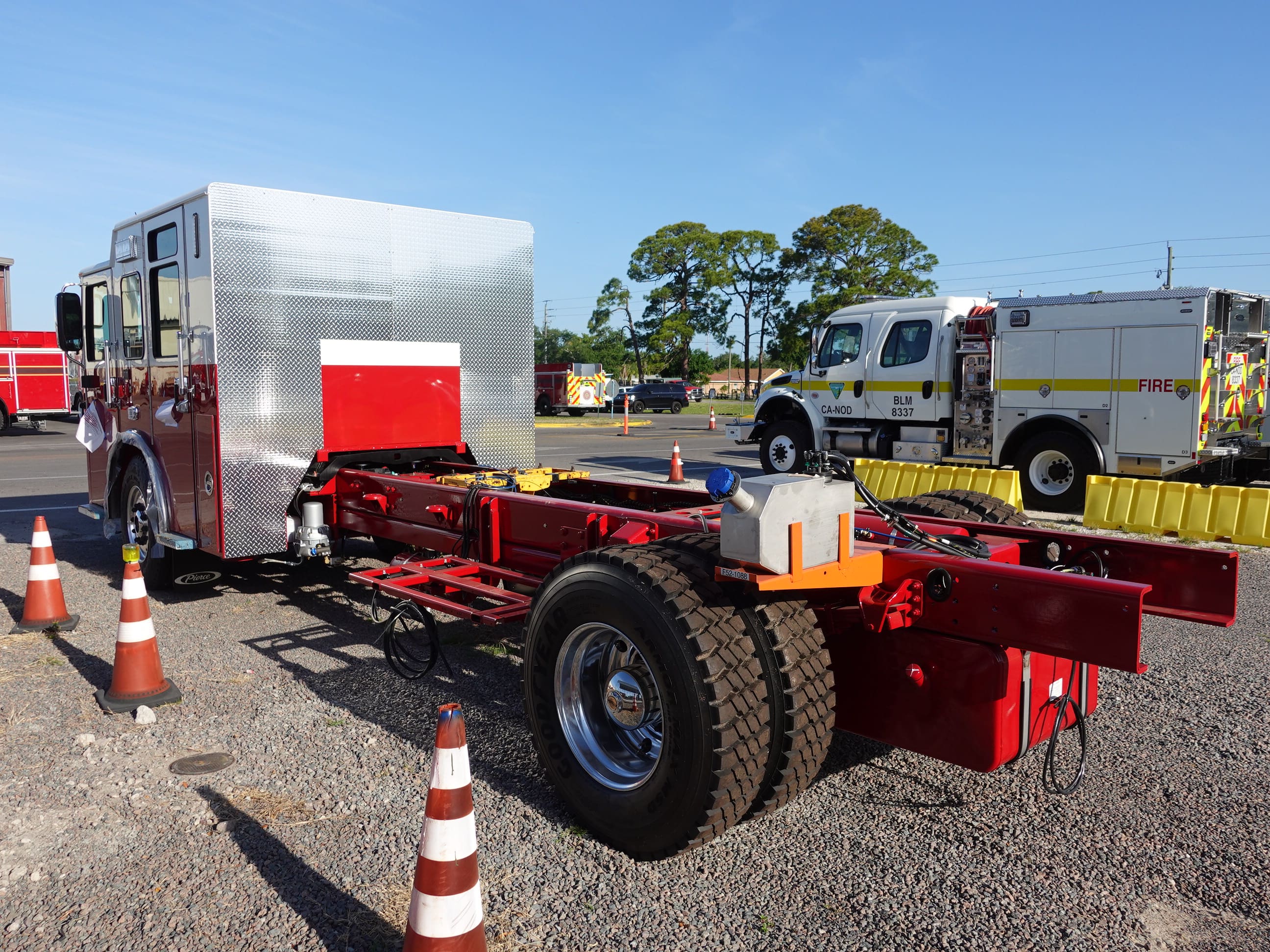

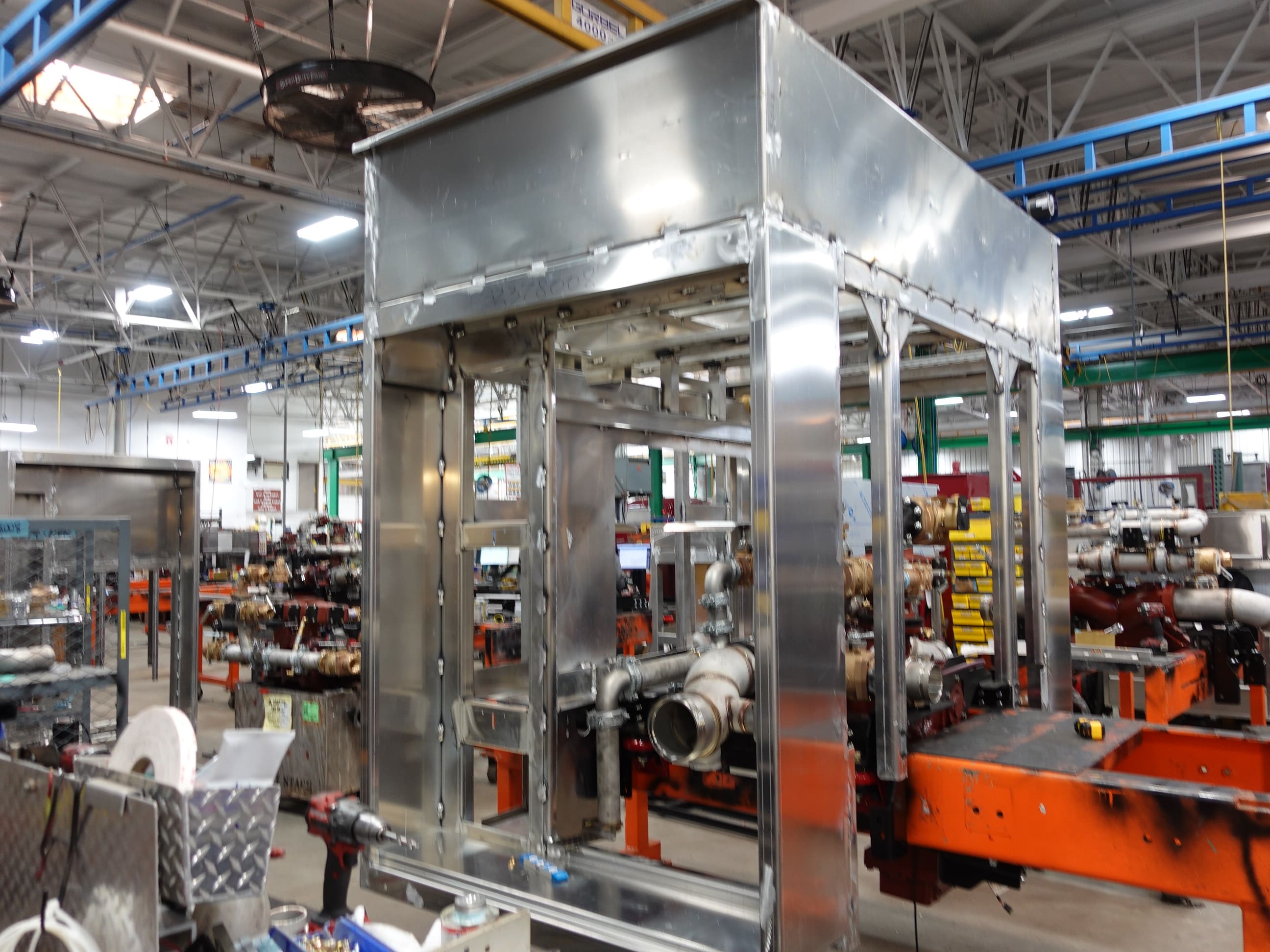

In this report, the chassis was staged offline, the pump house completed initial assembly, and the body was staged.

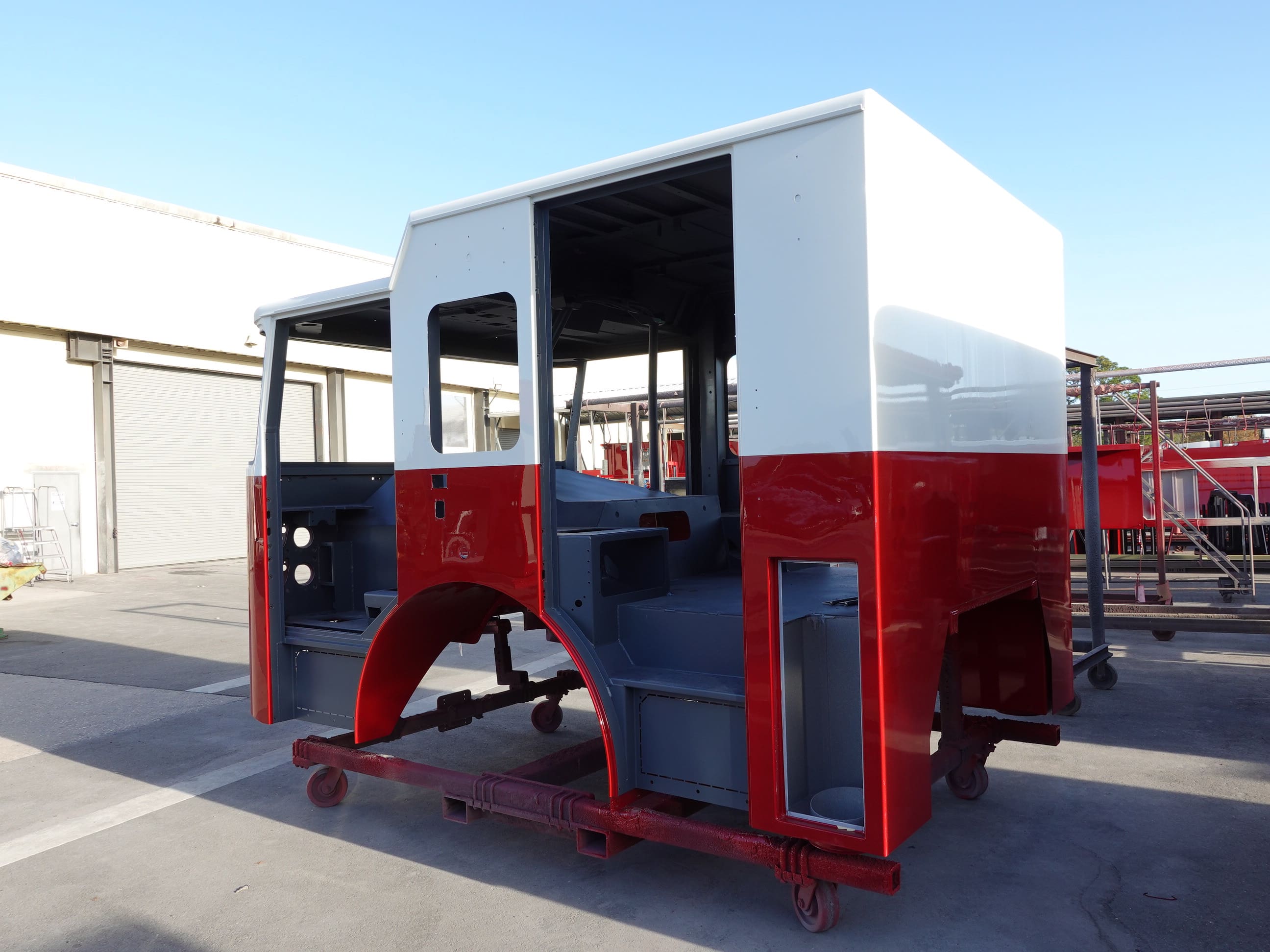

04-17-26

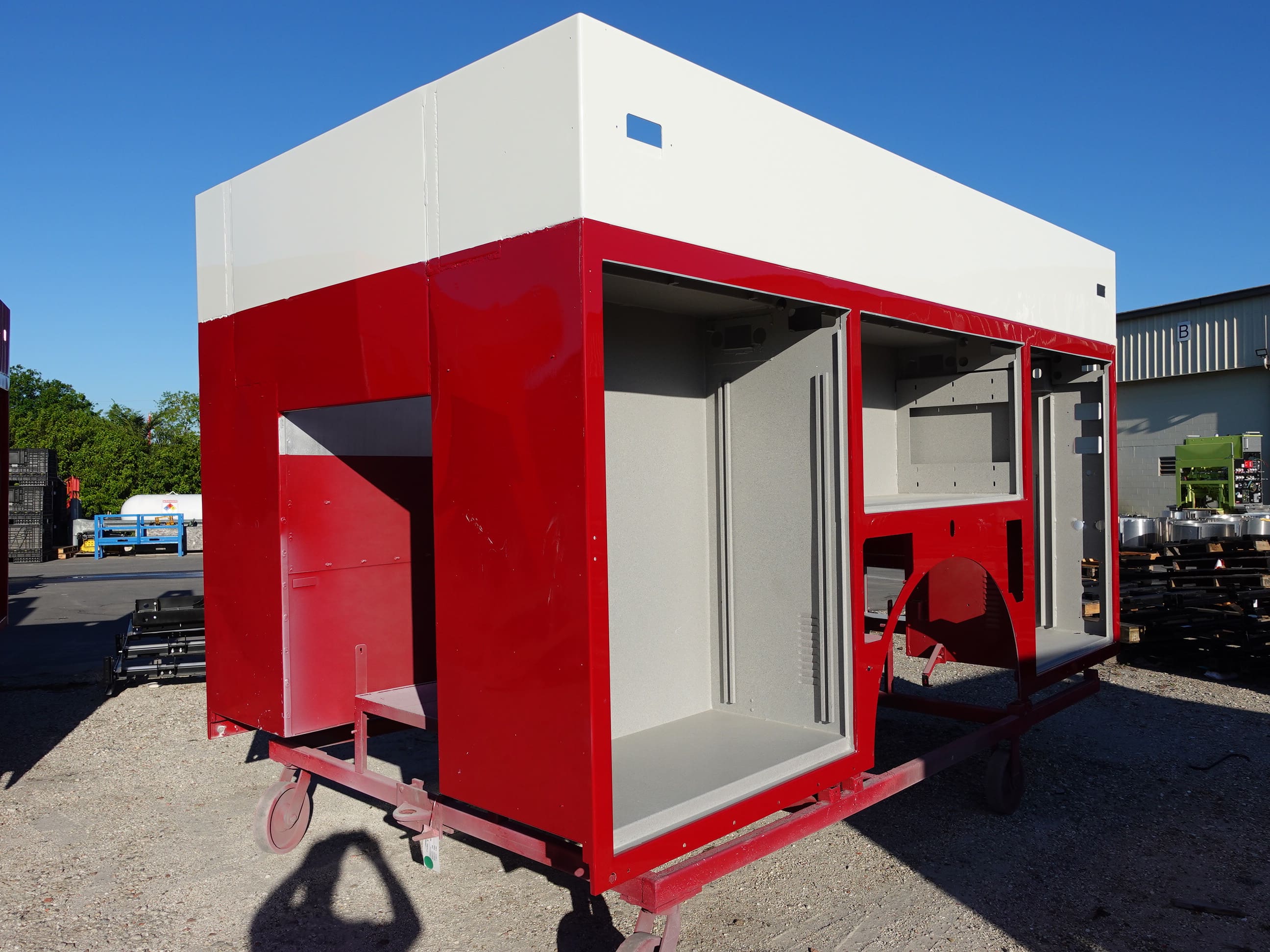

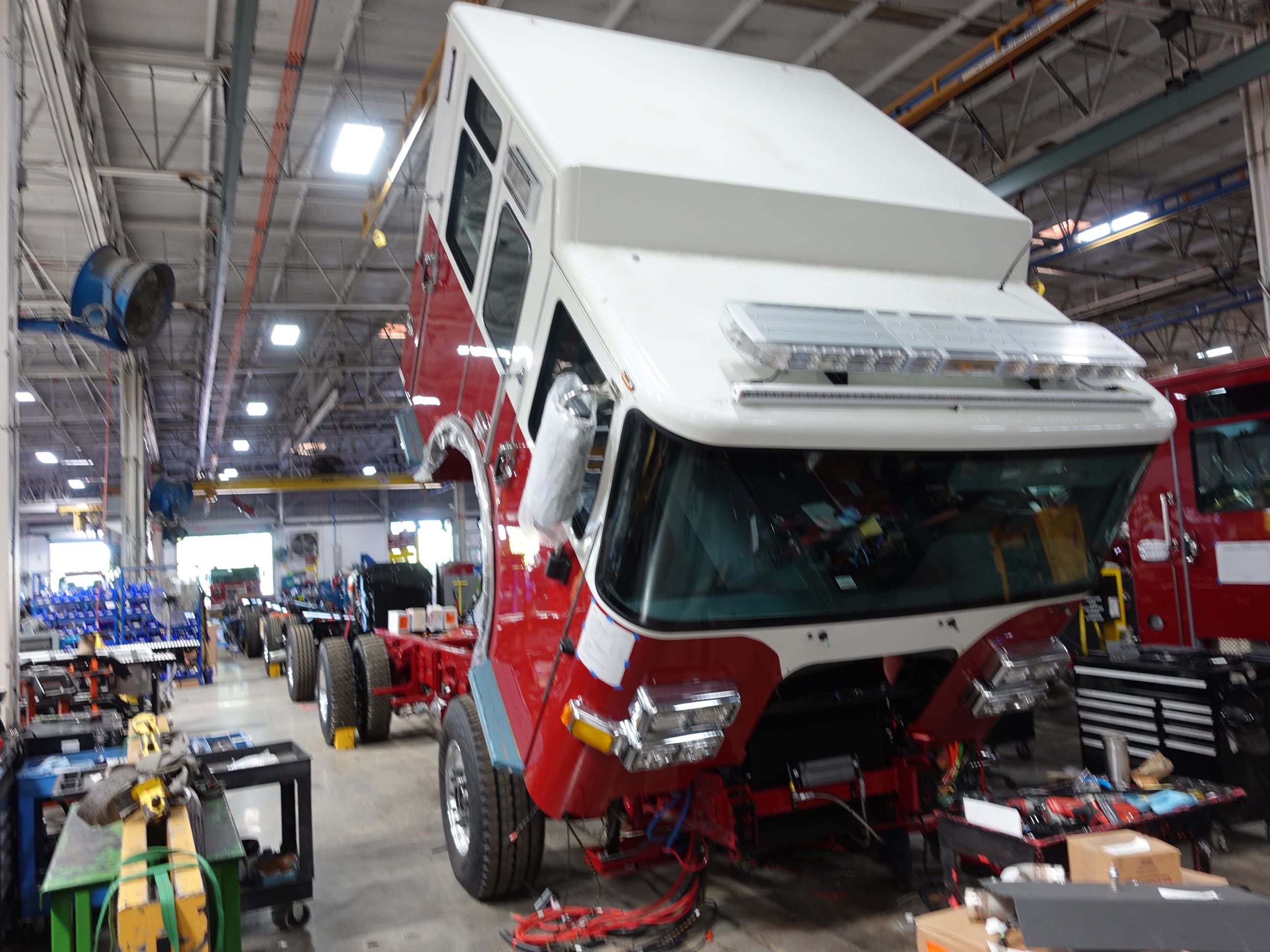

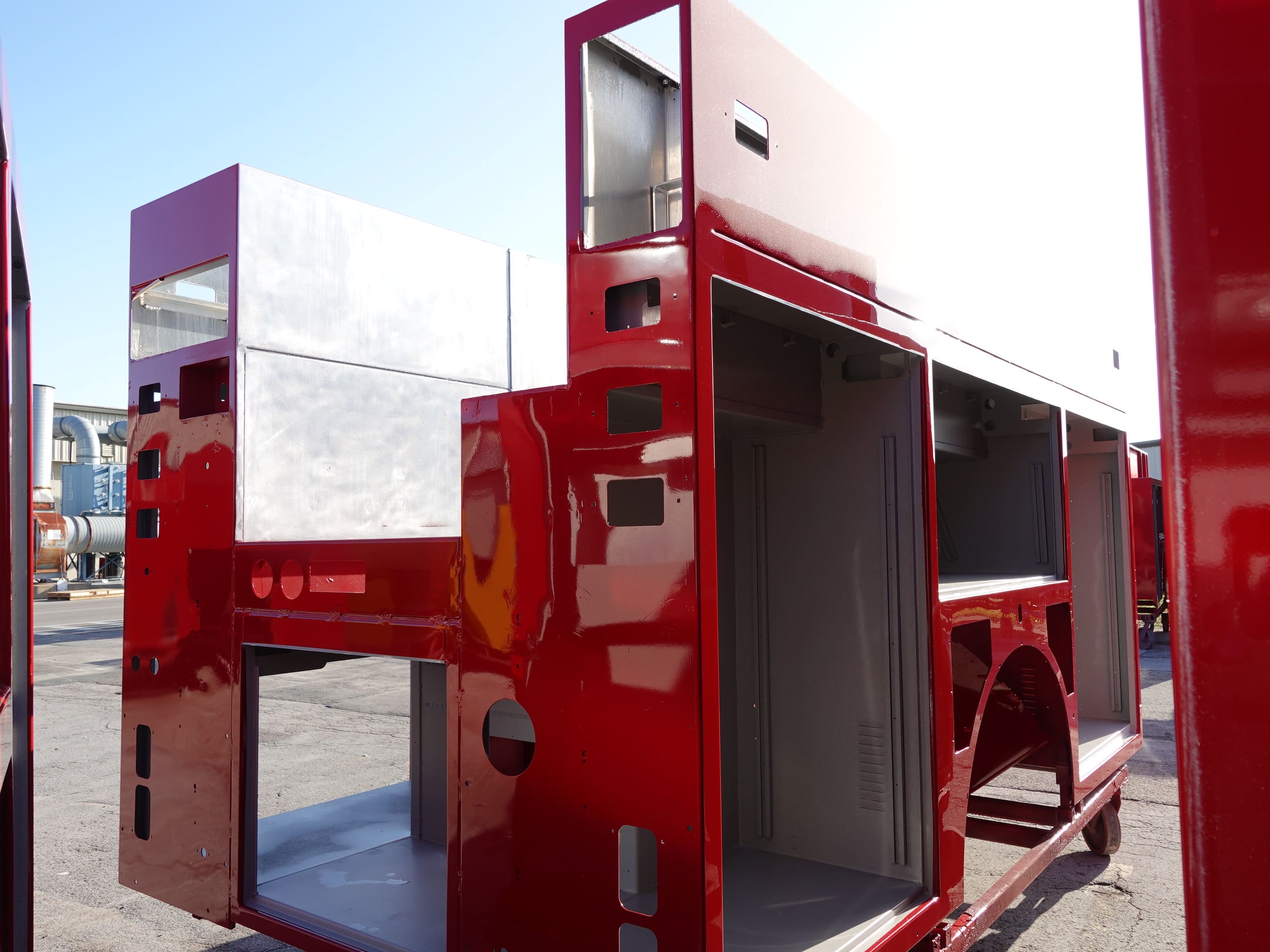

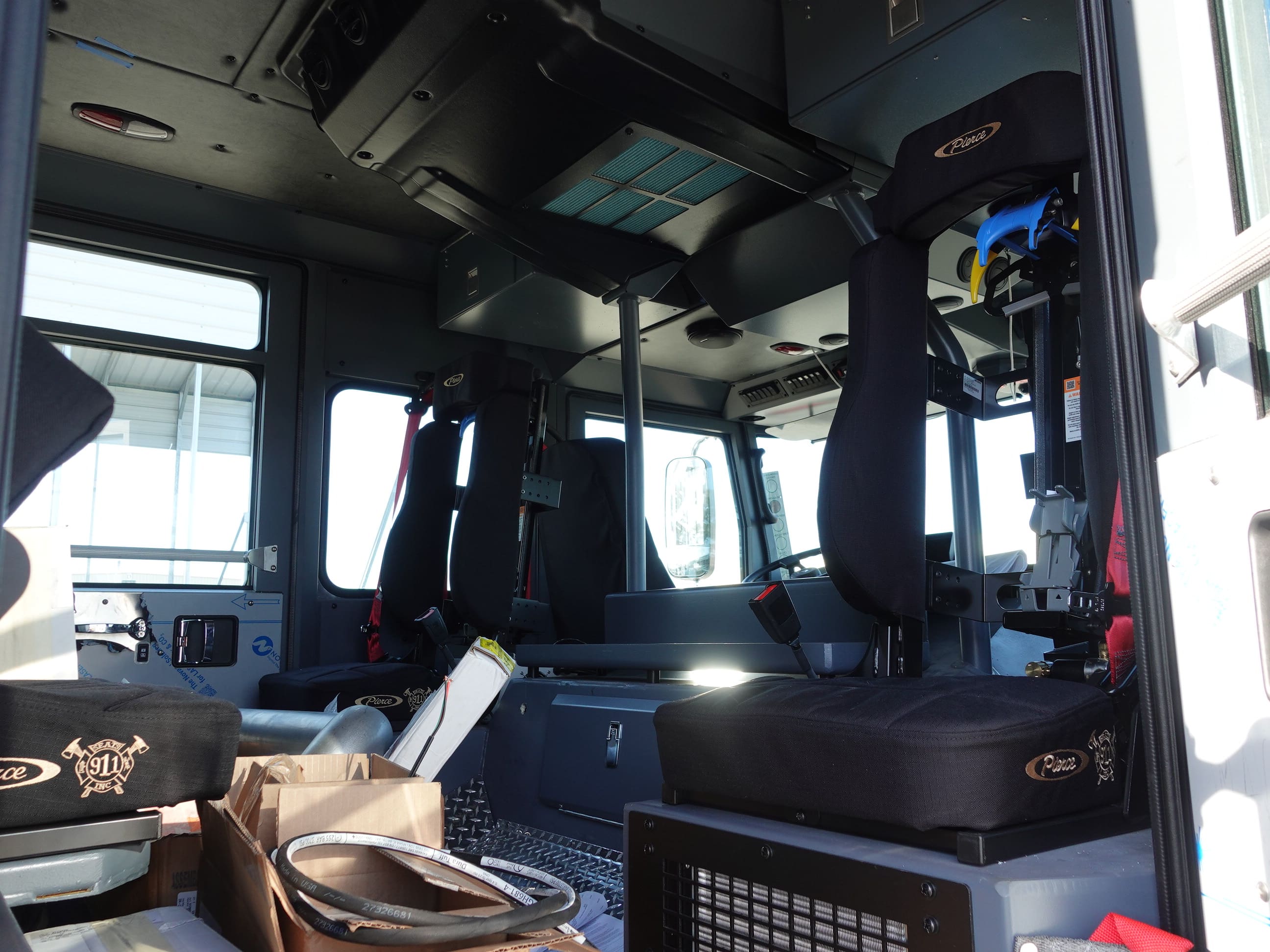

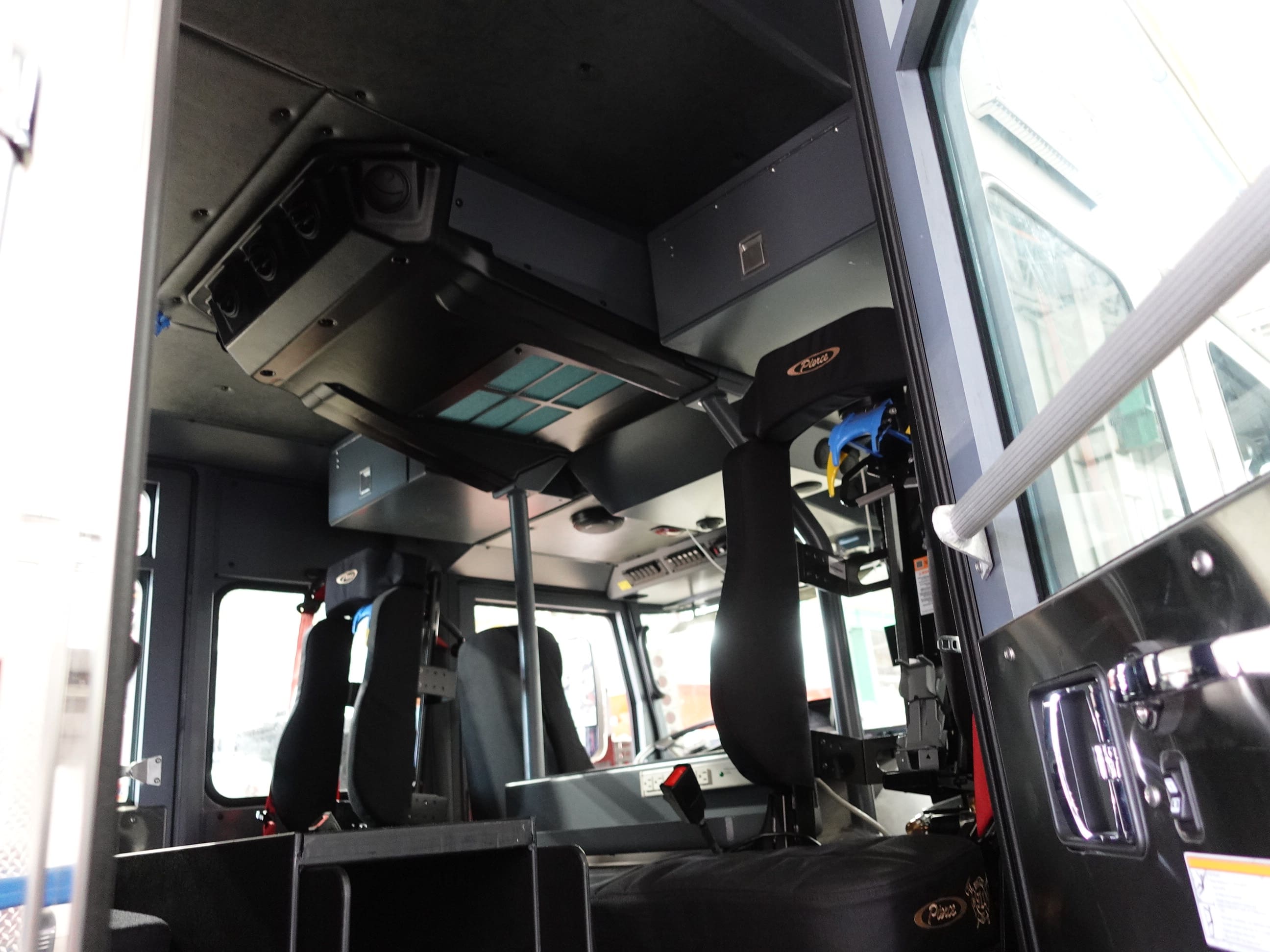

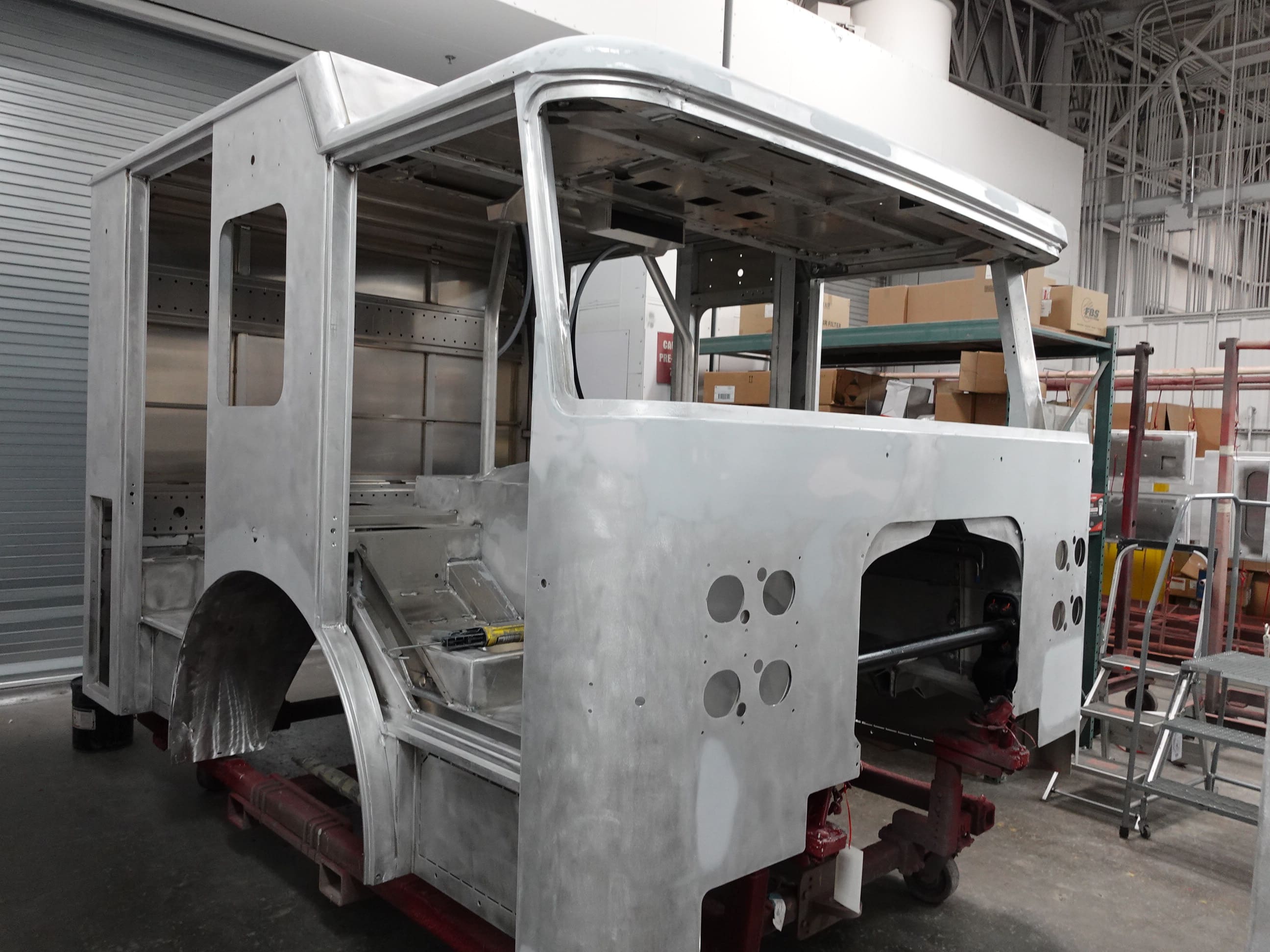

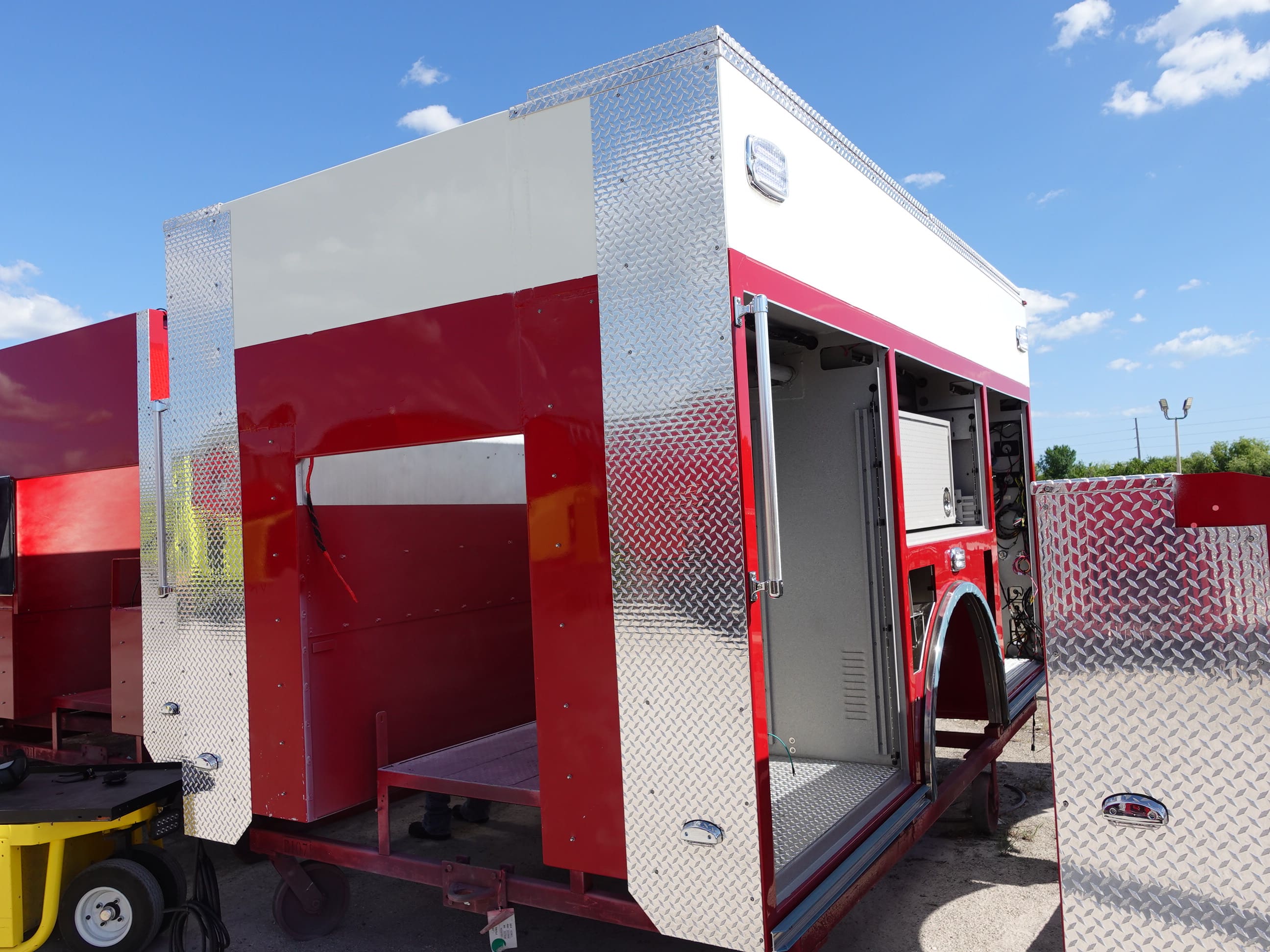

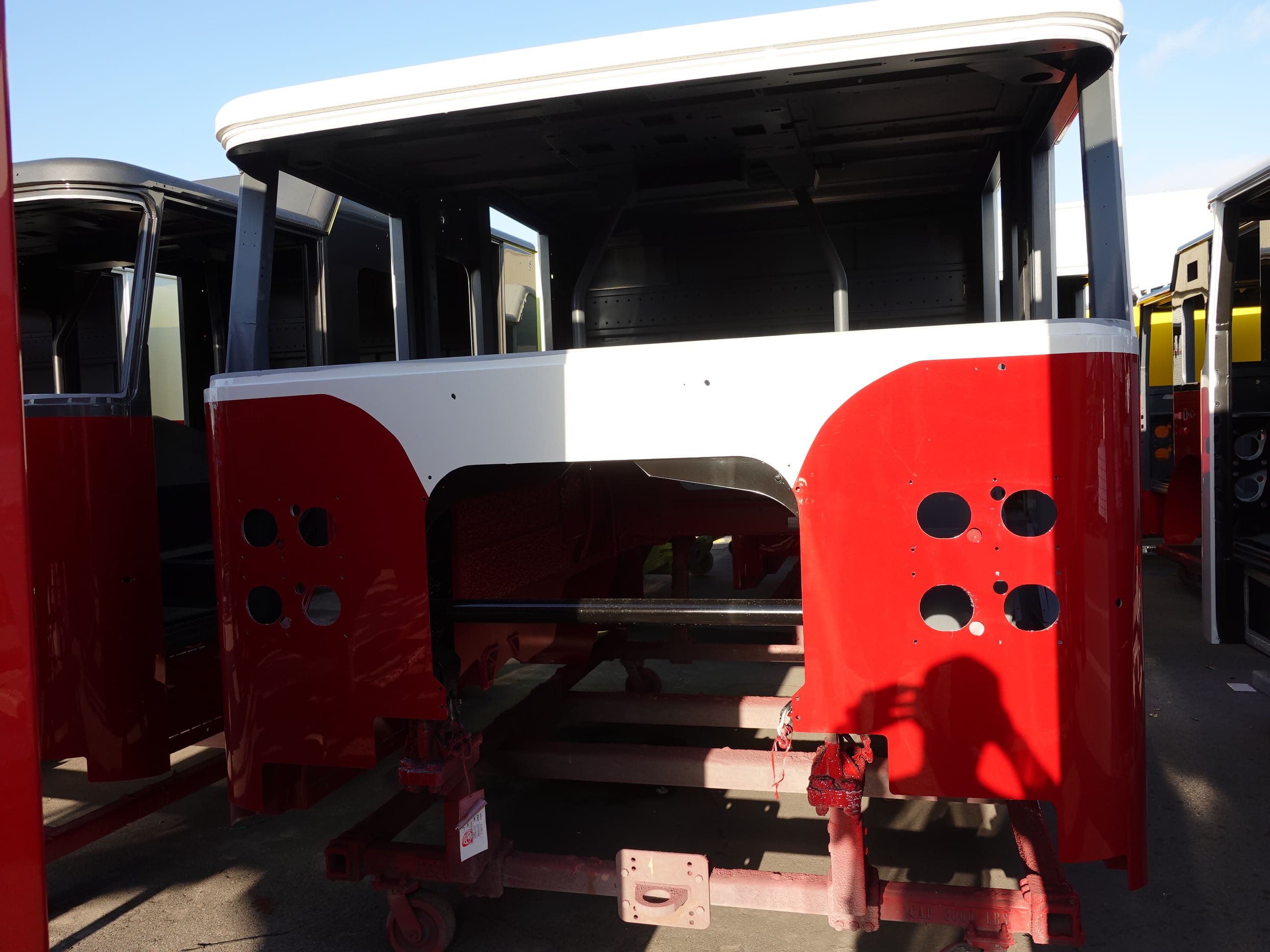

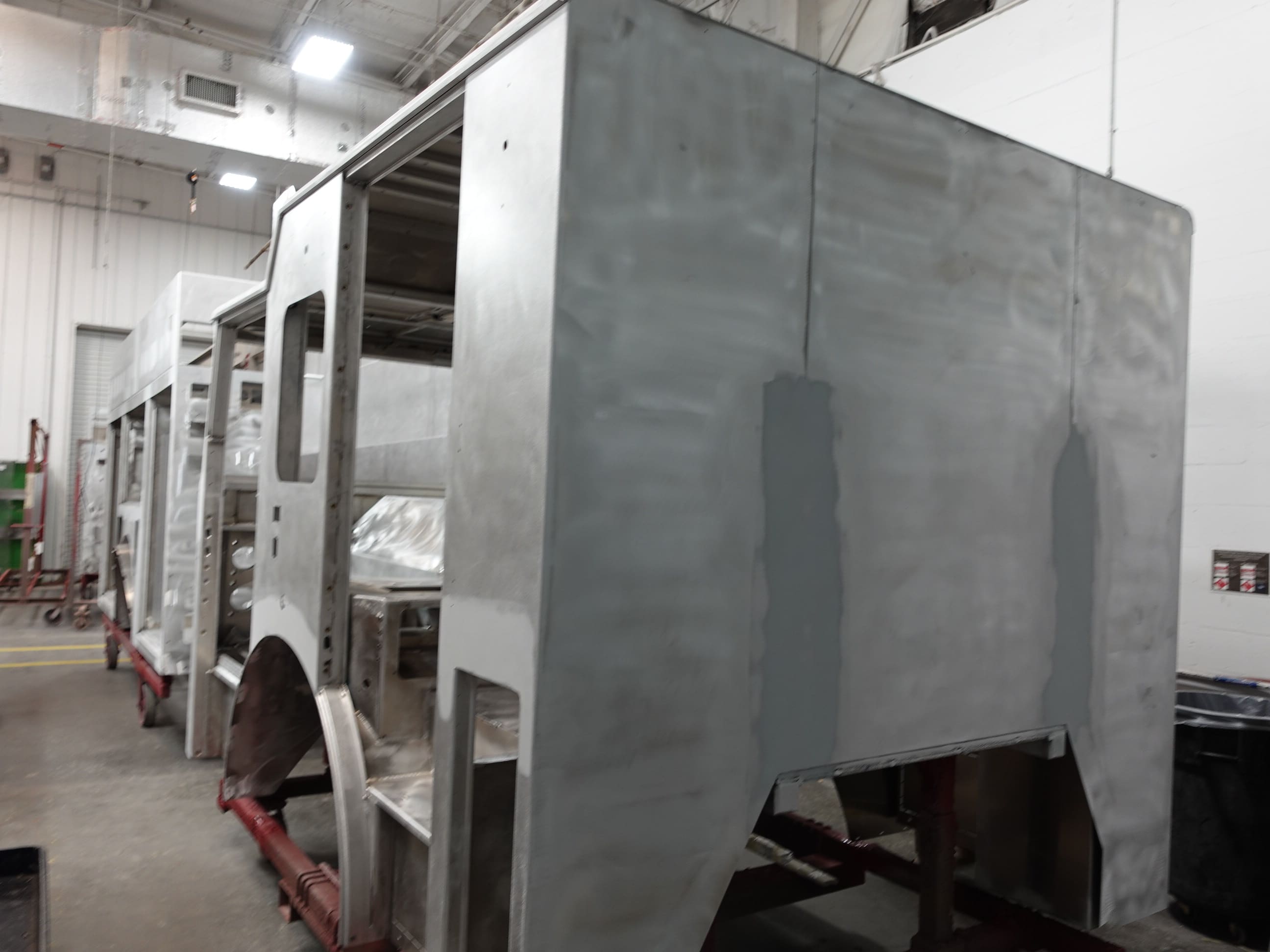

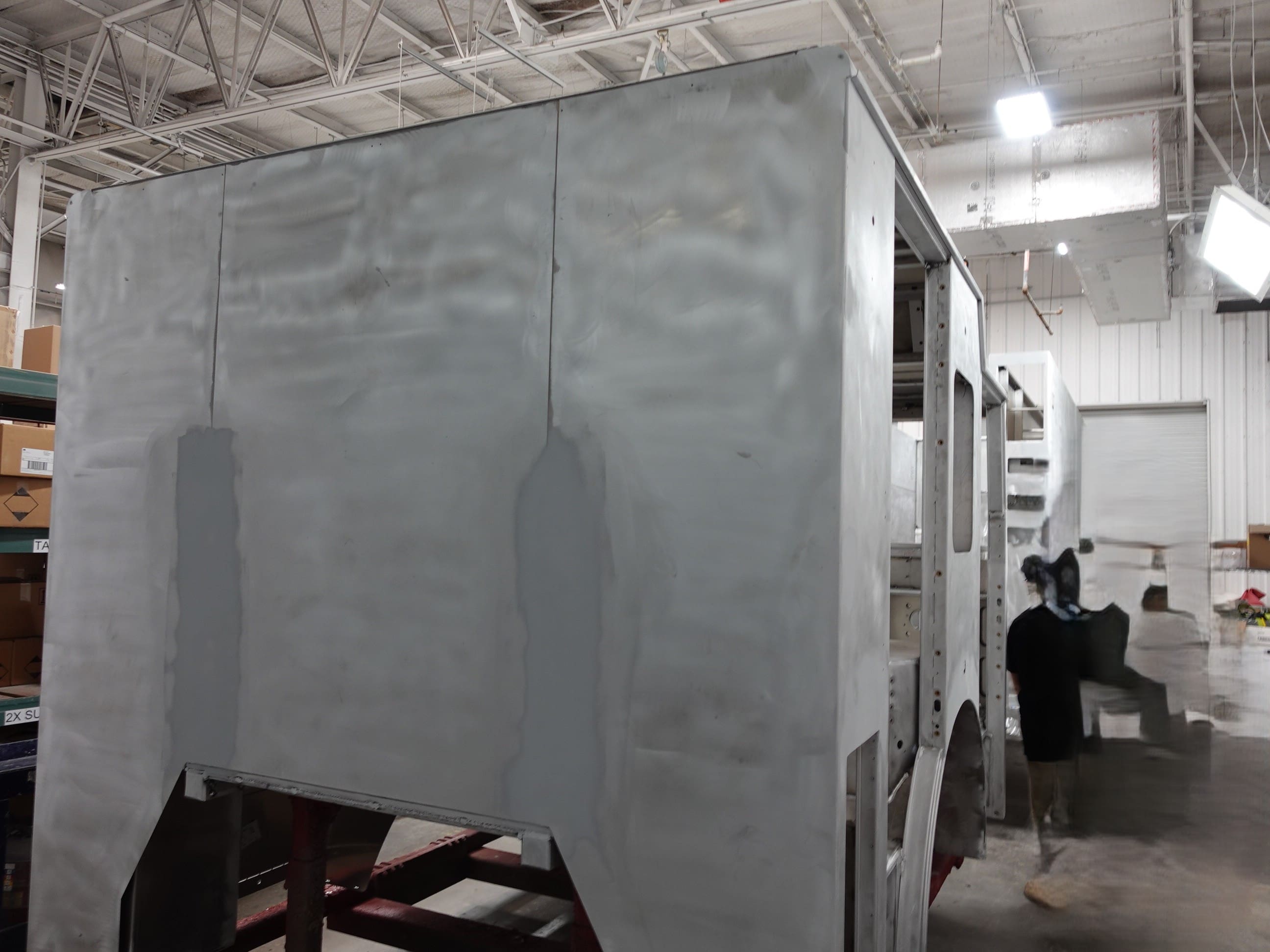

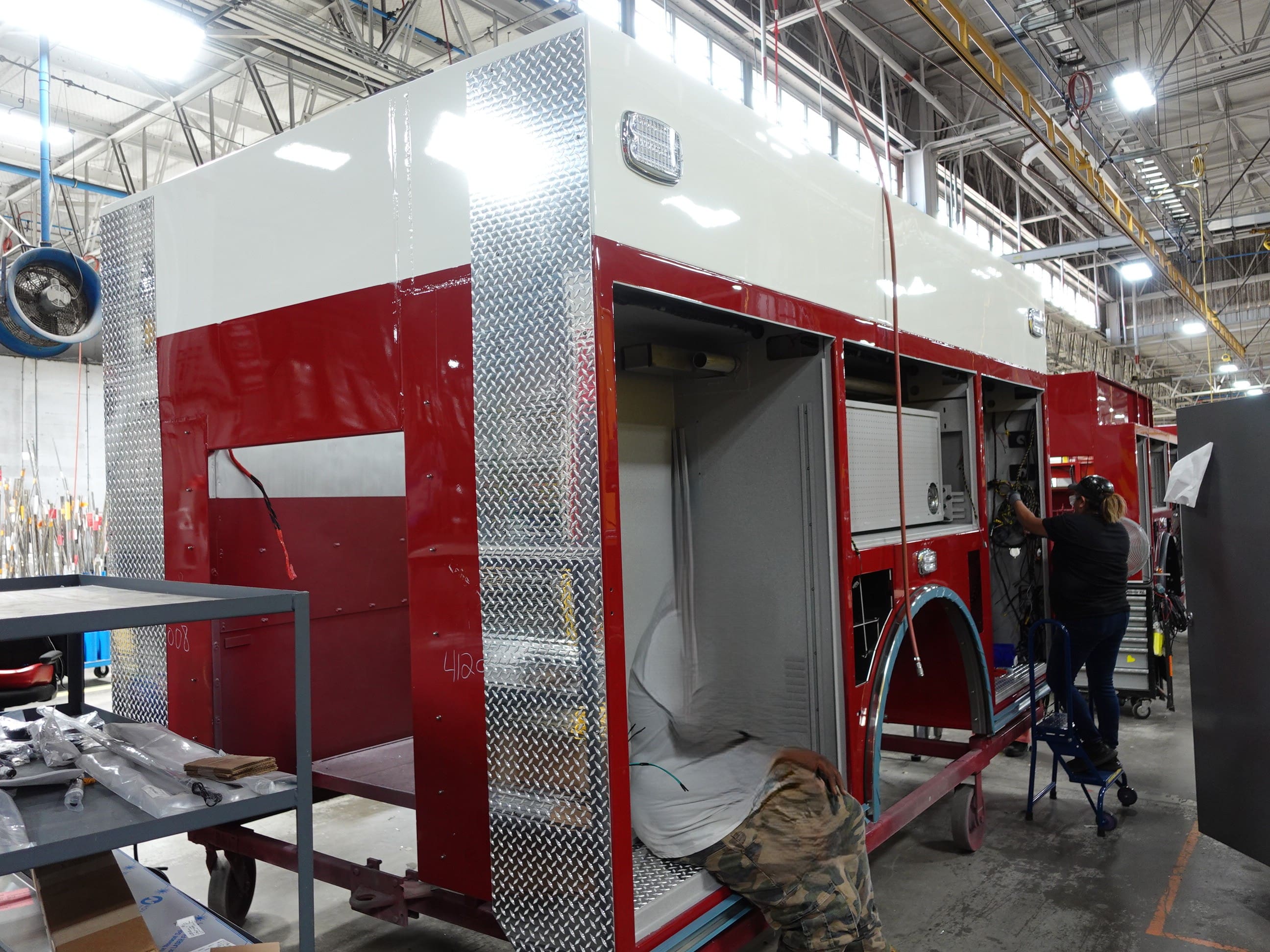

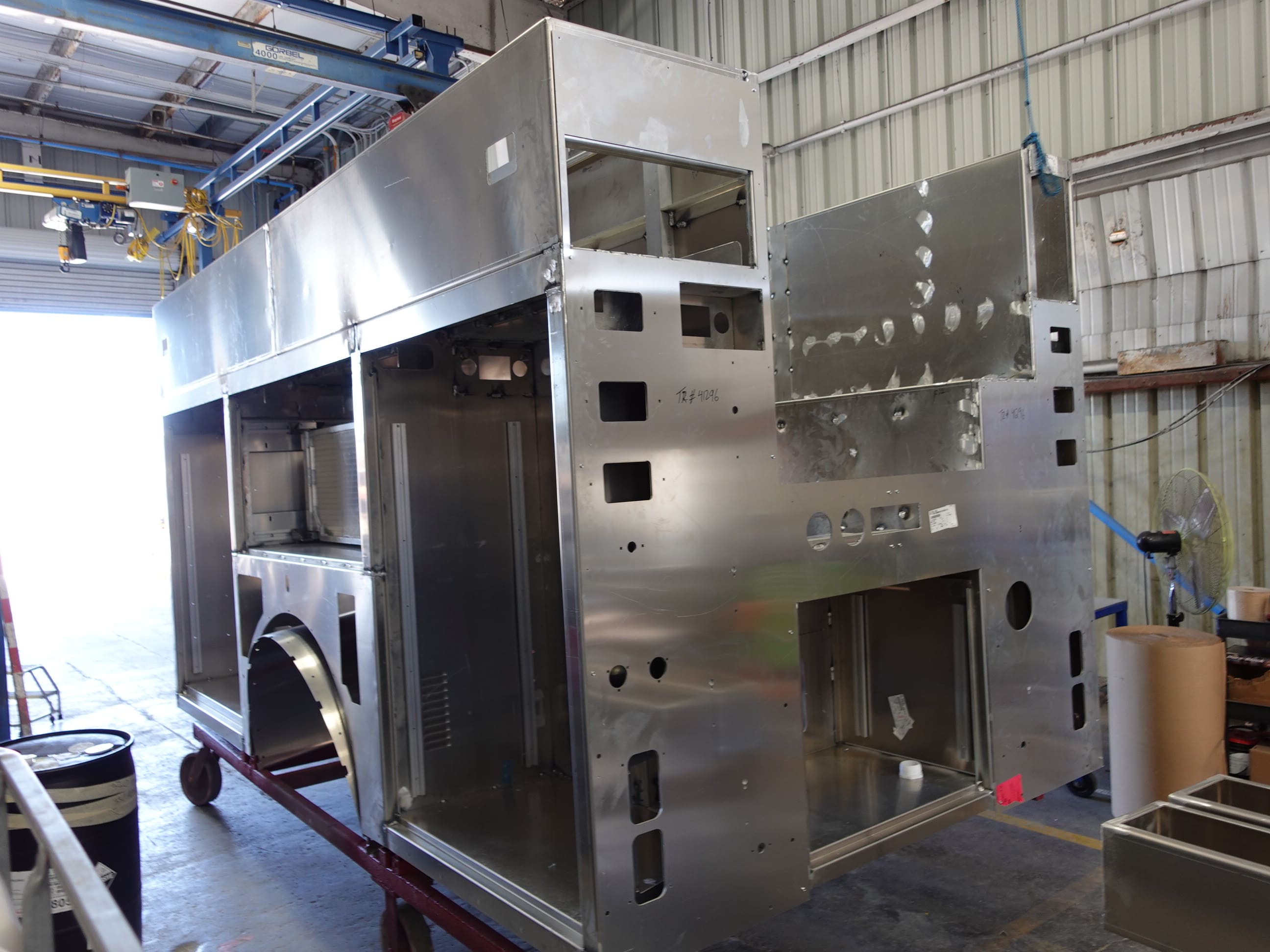

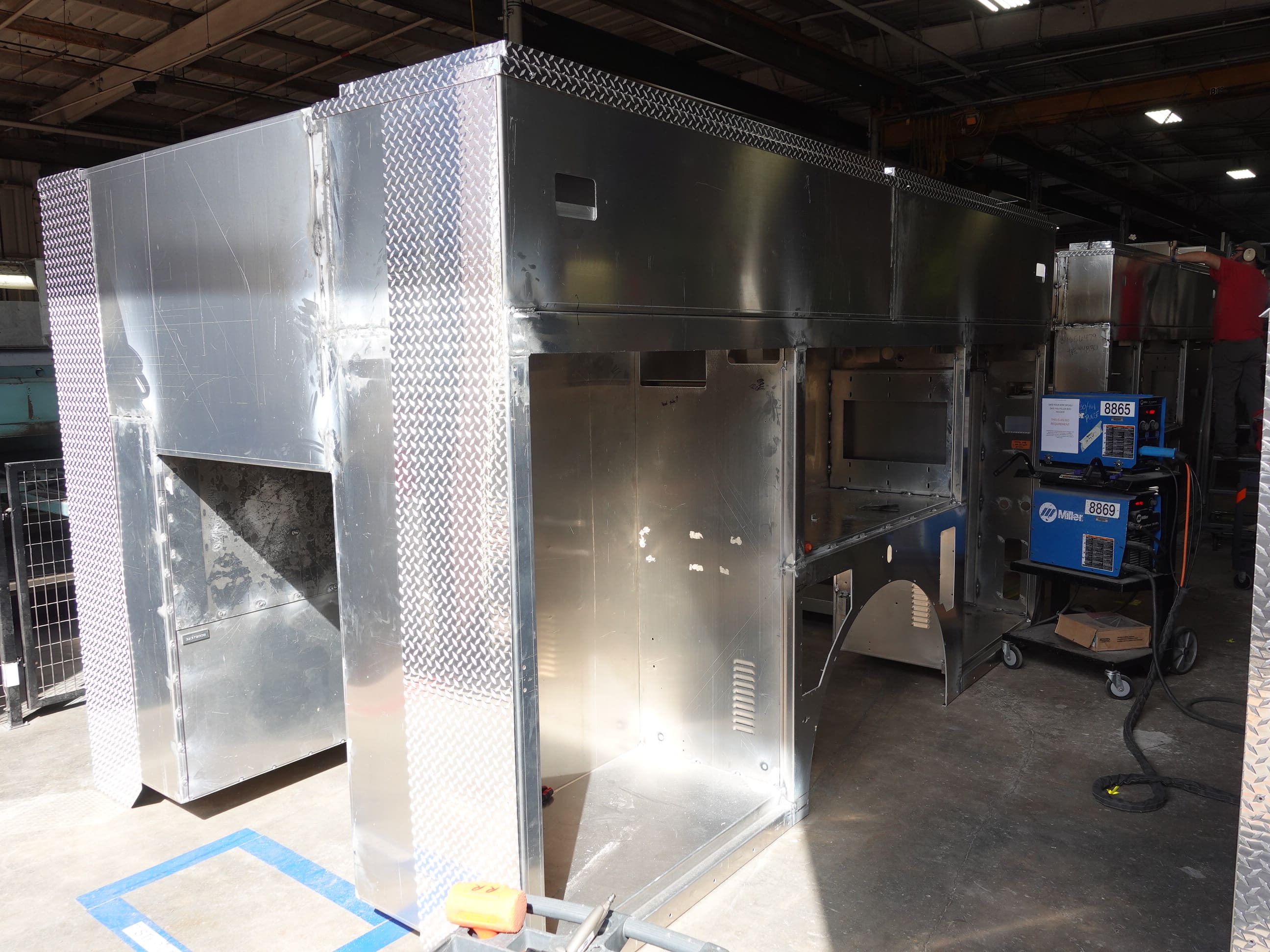

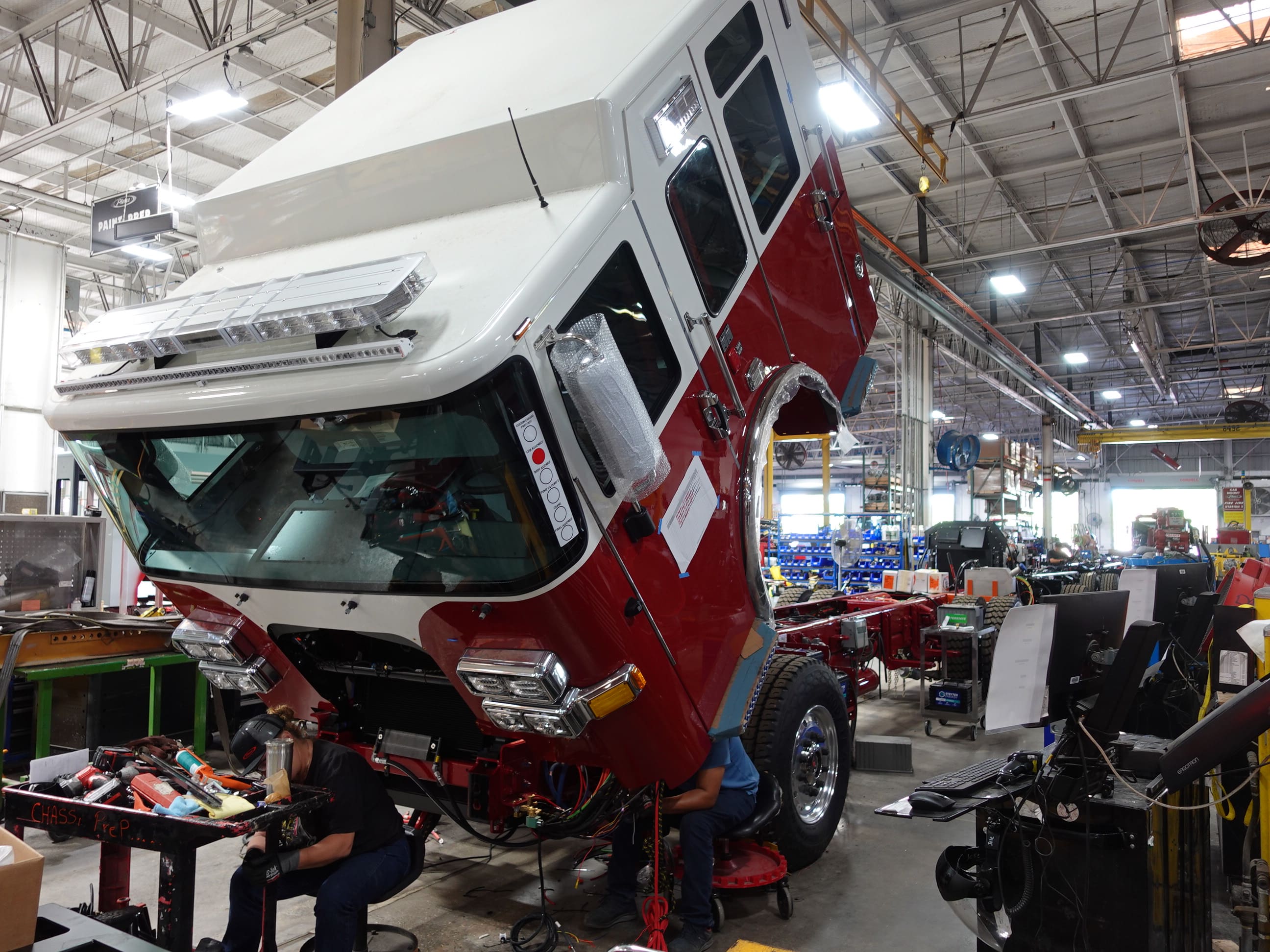

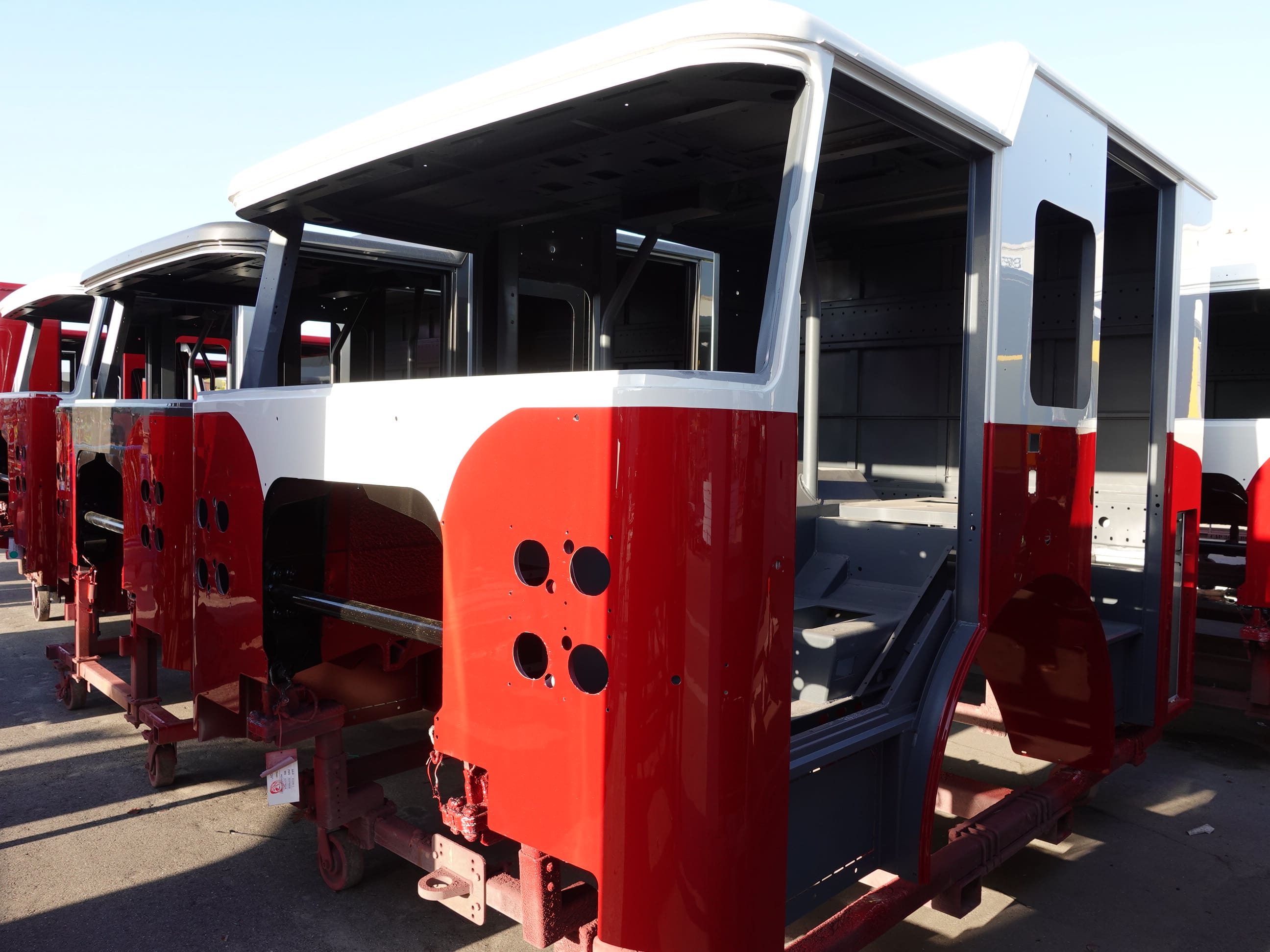

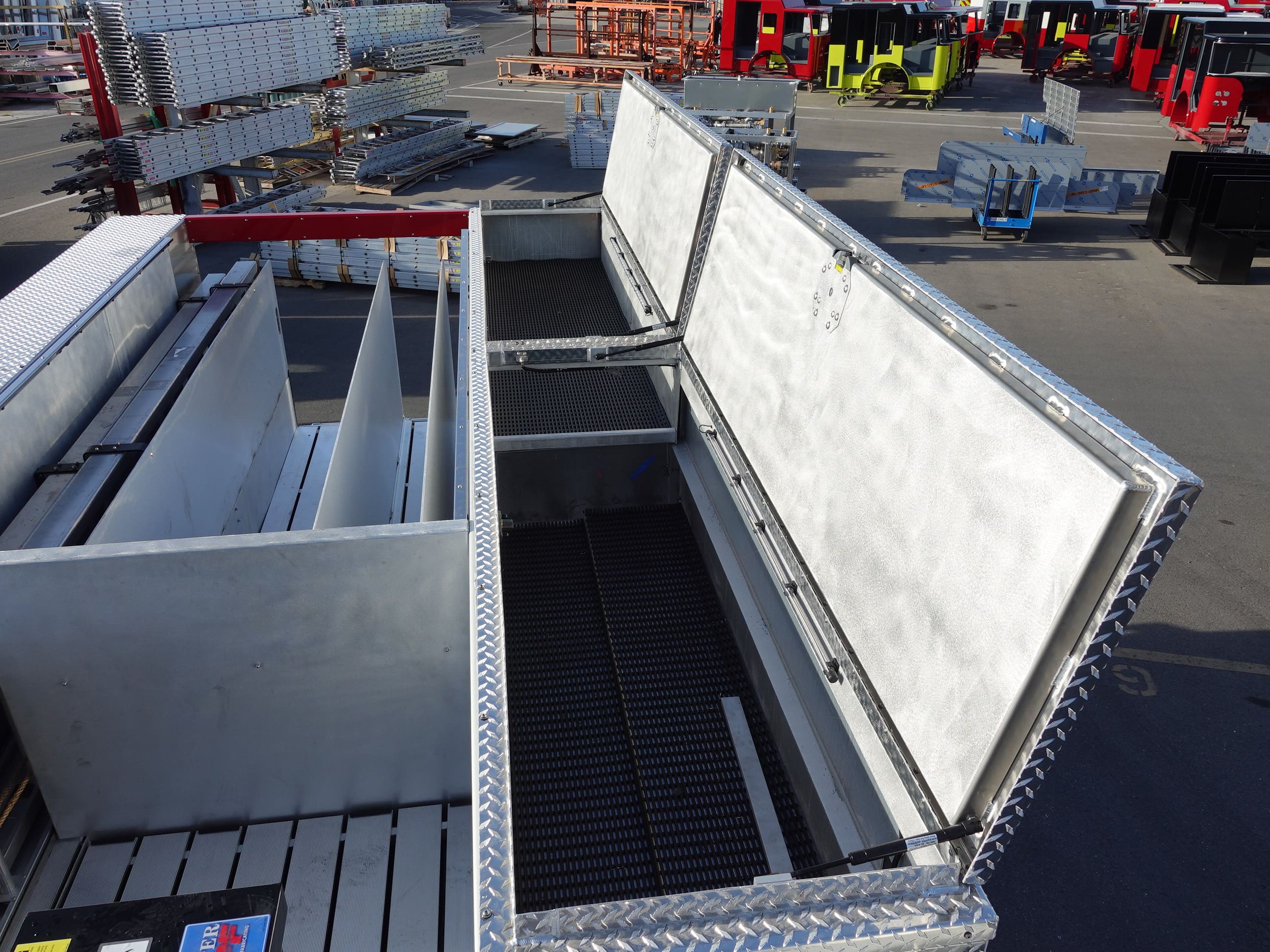

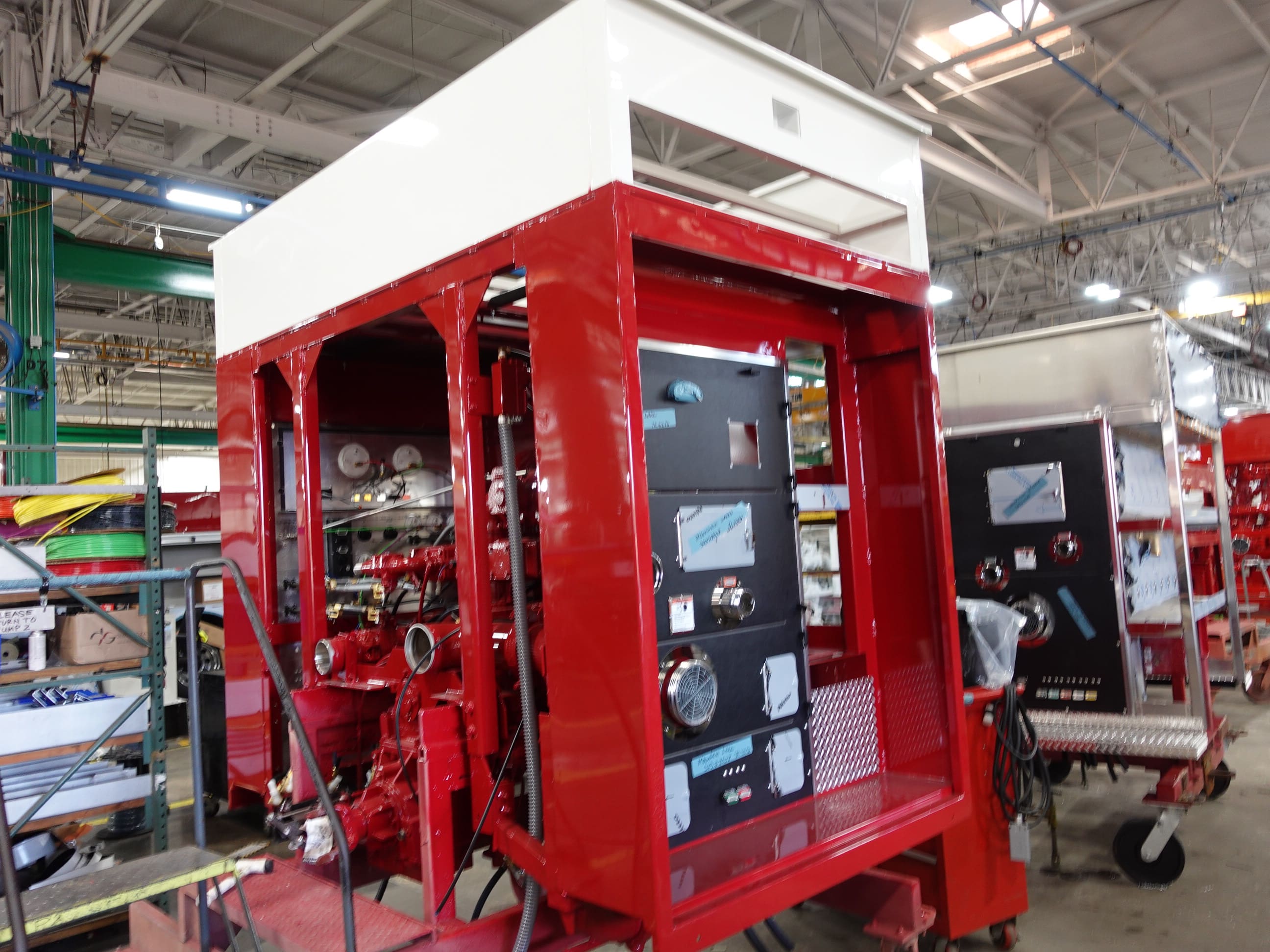

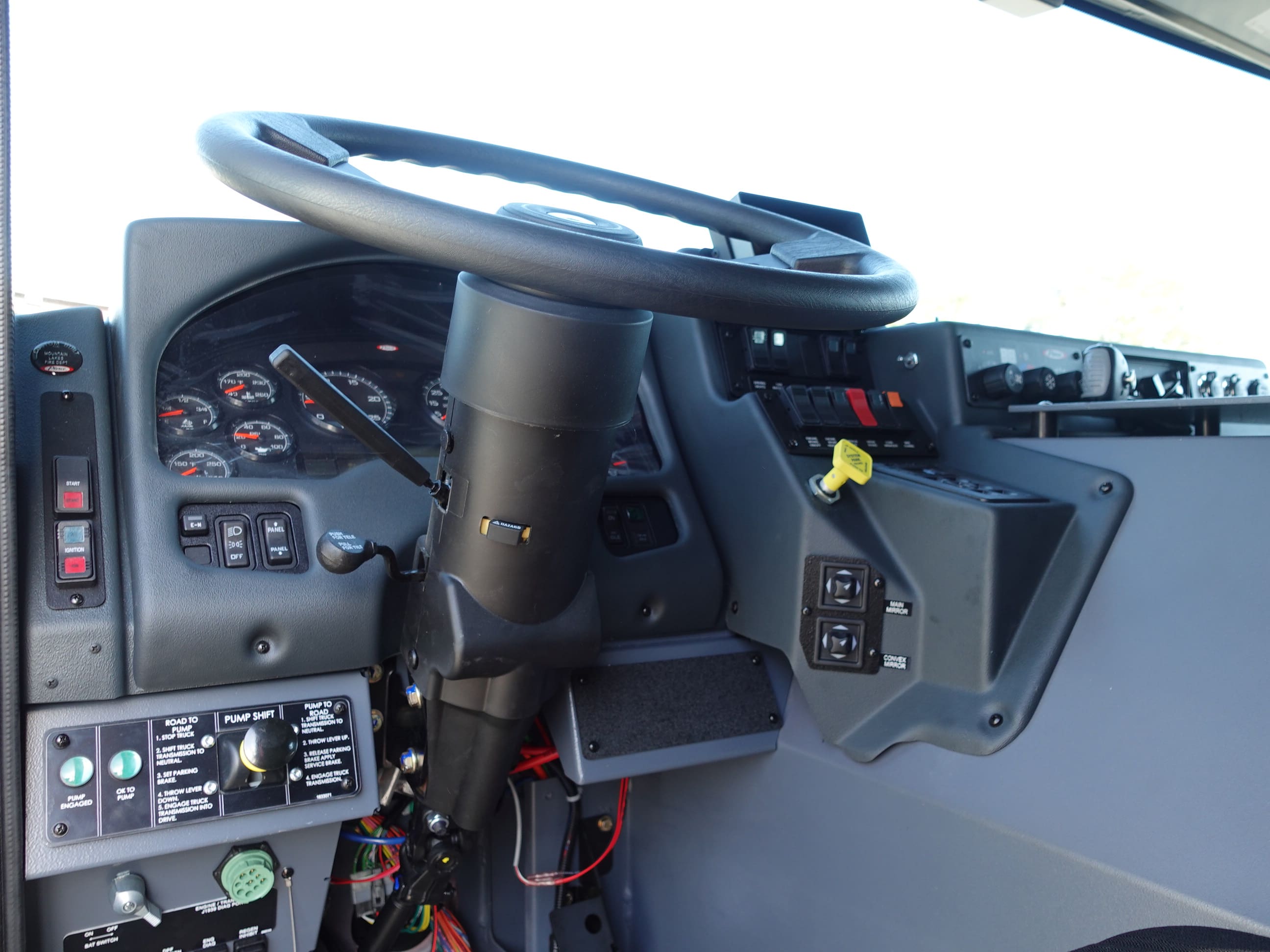

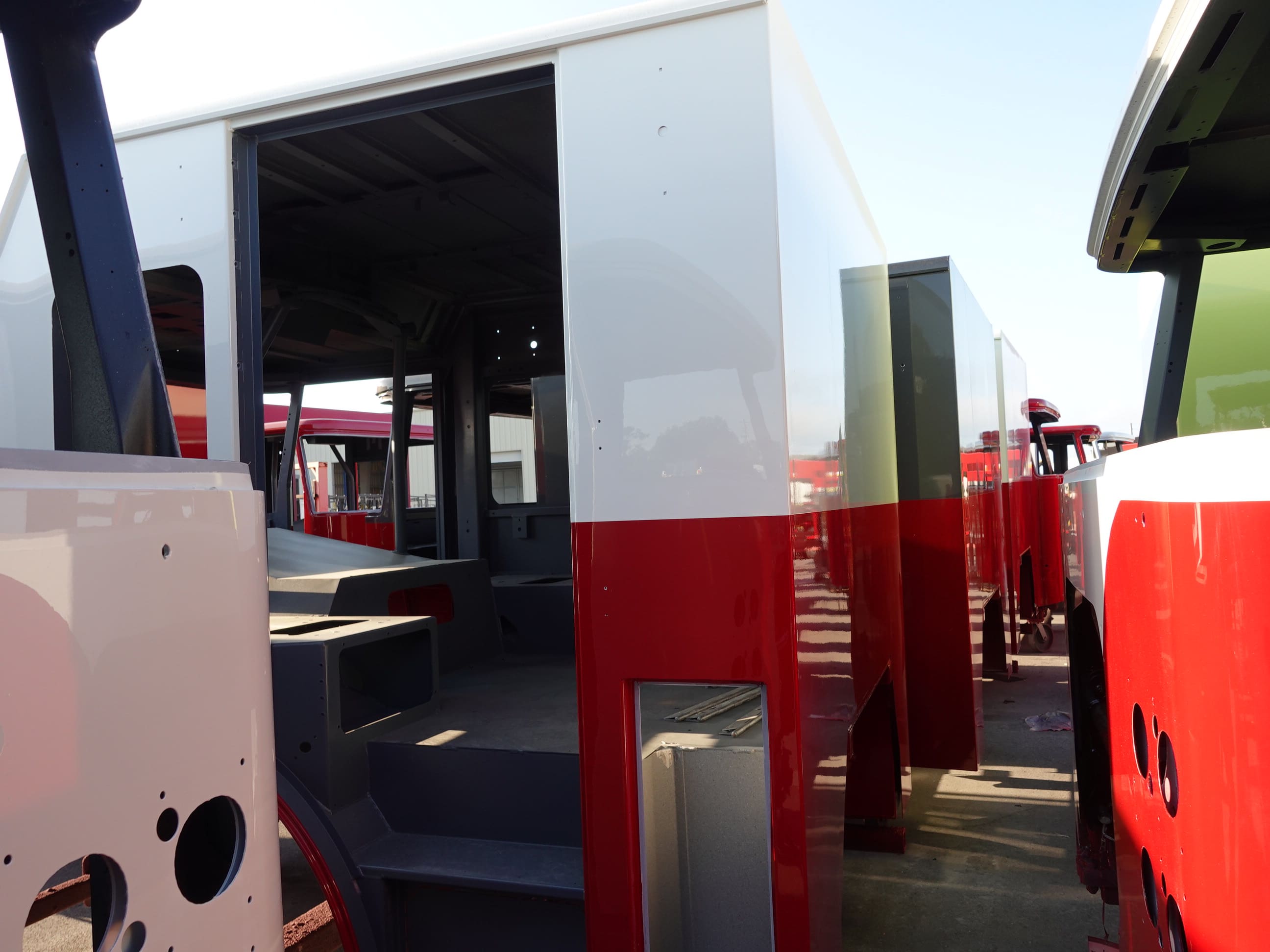

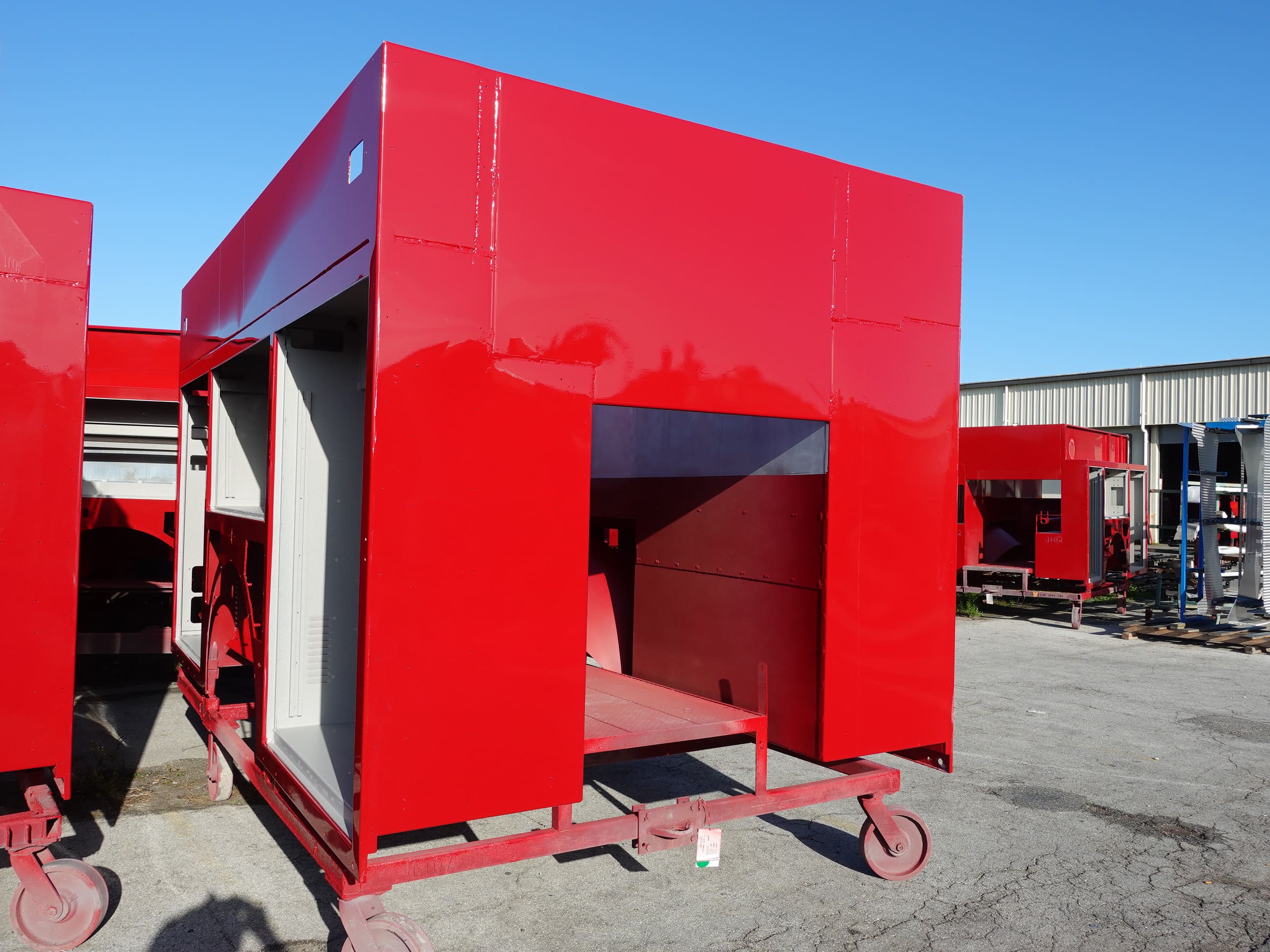

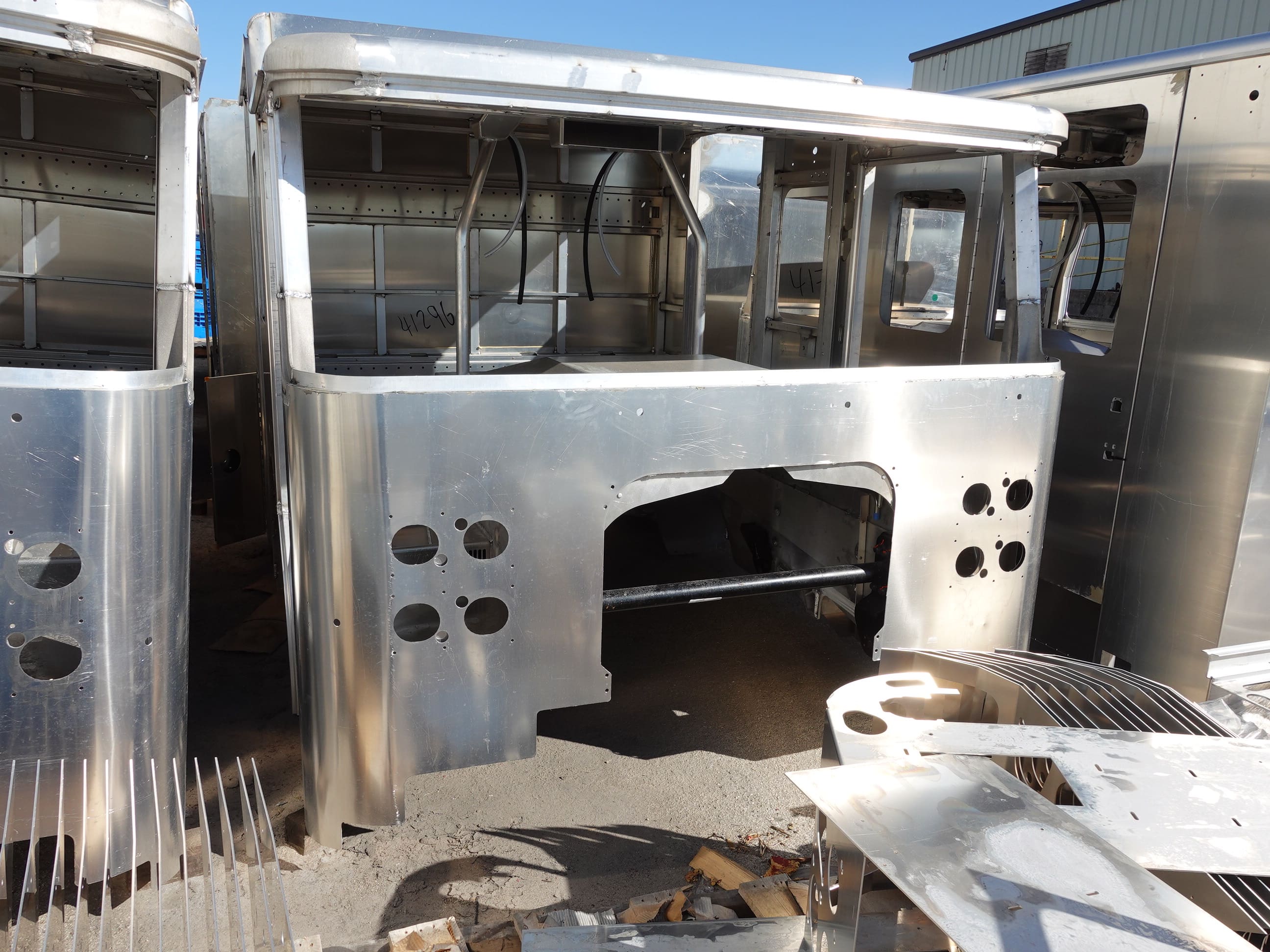

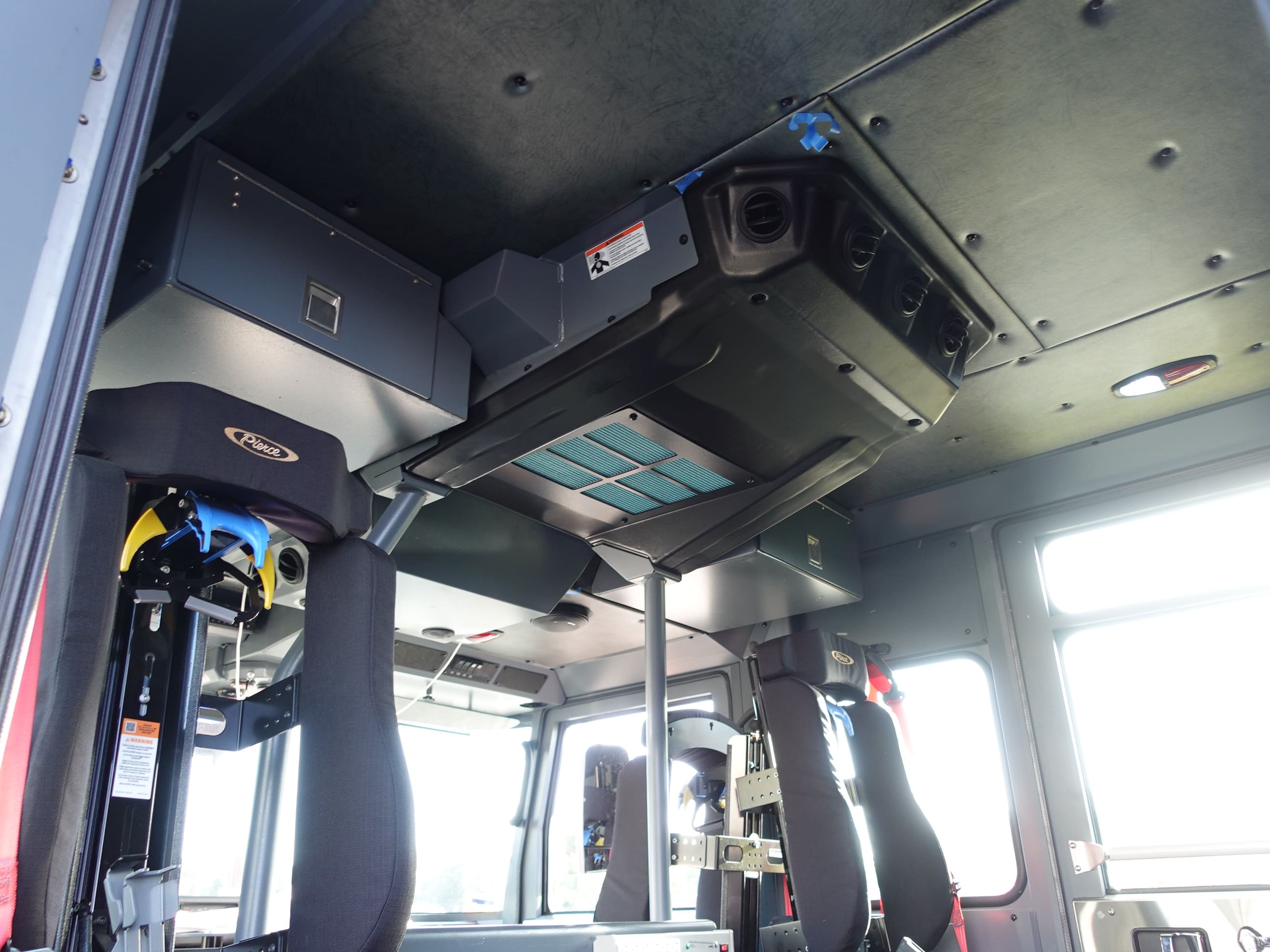

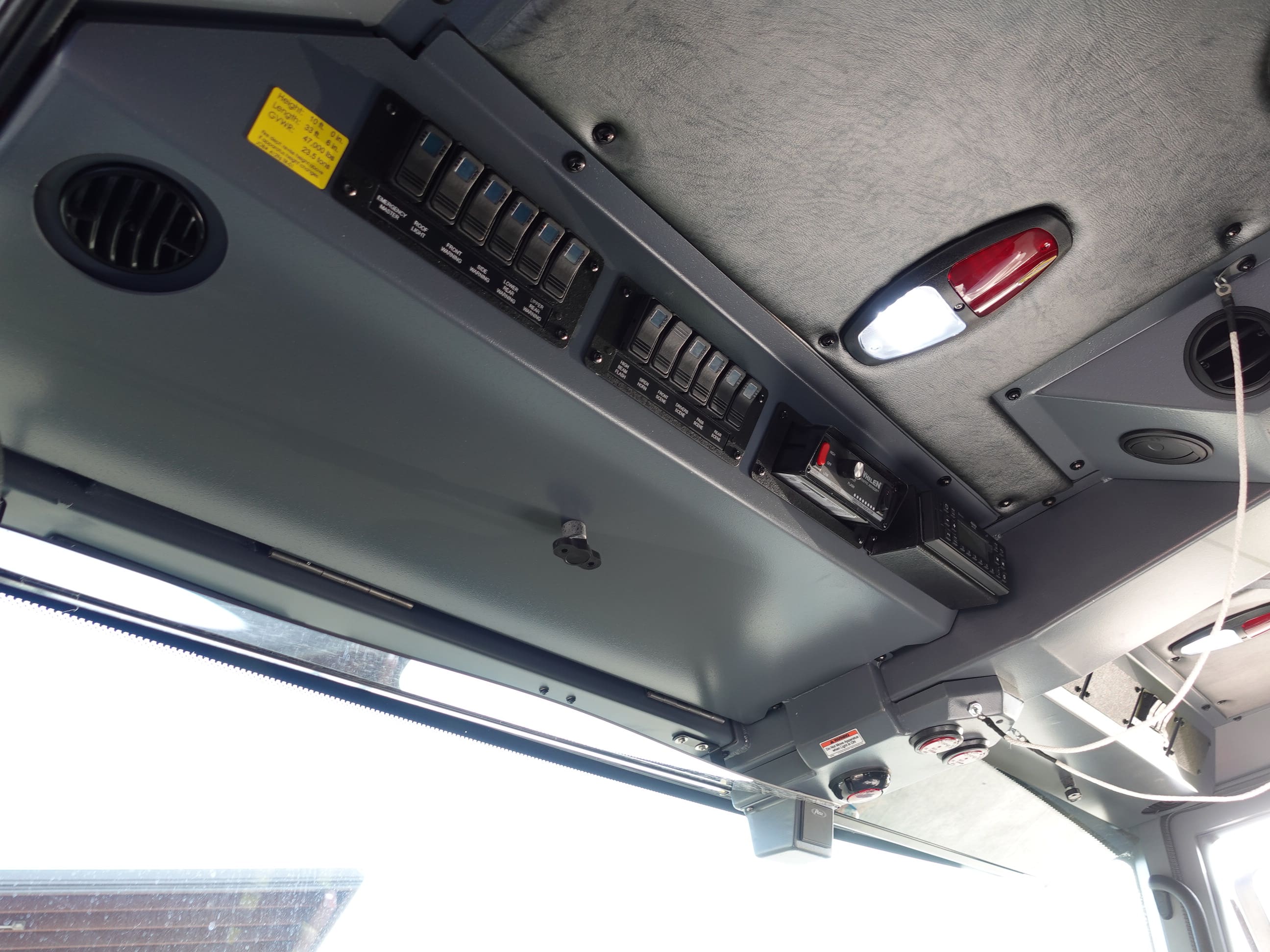

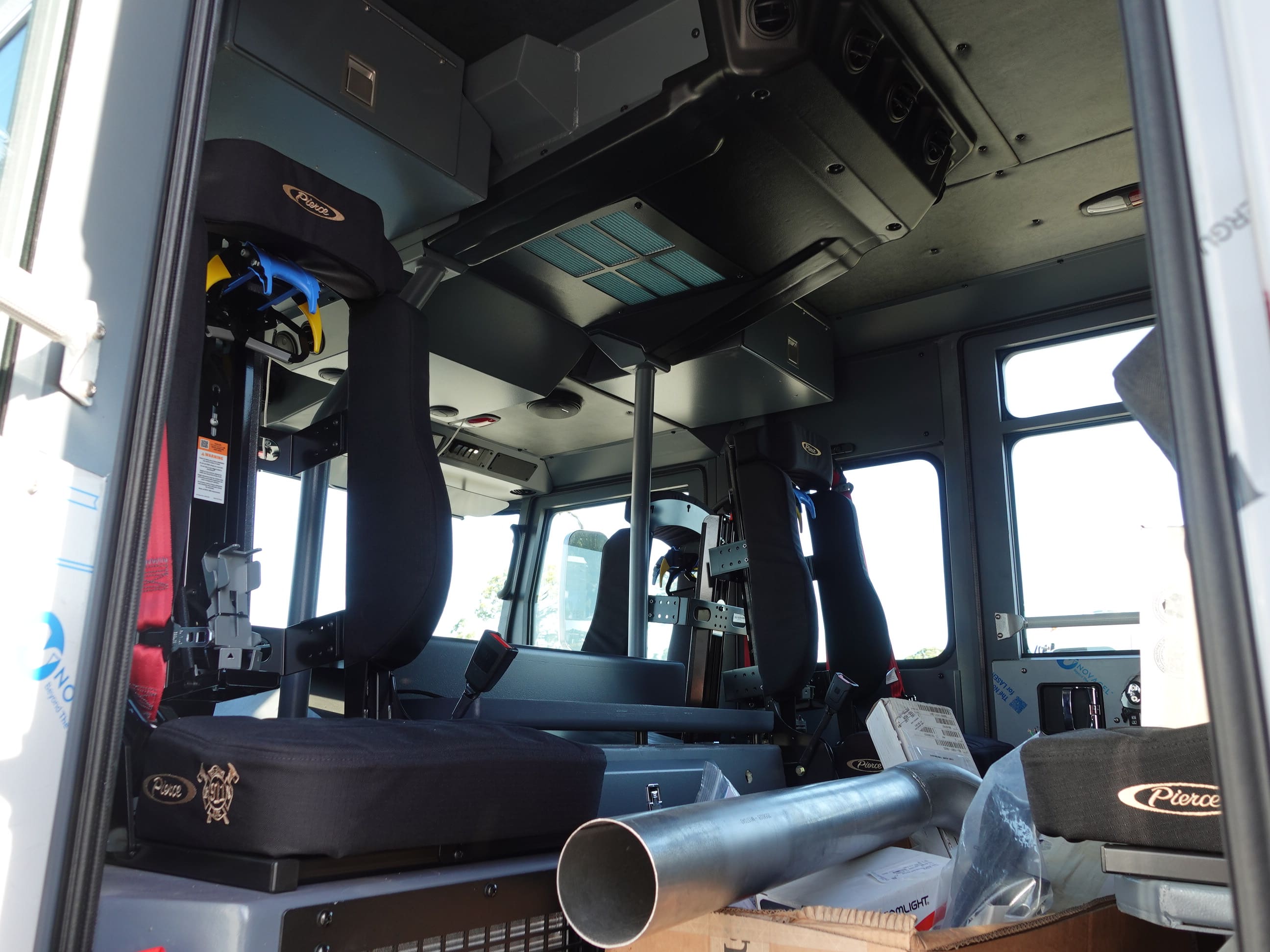

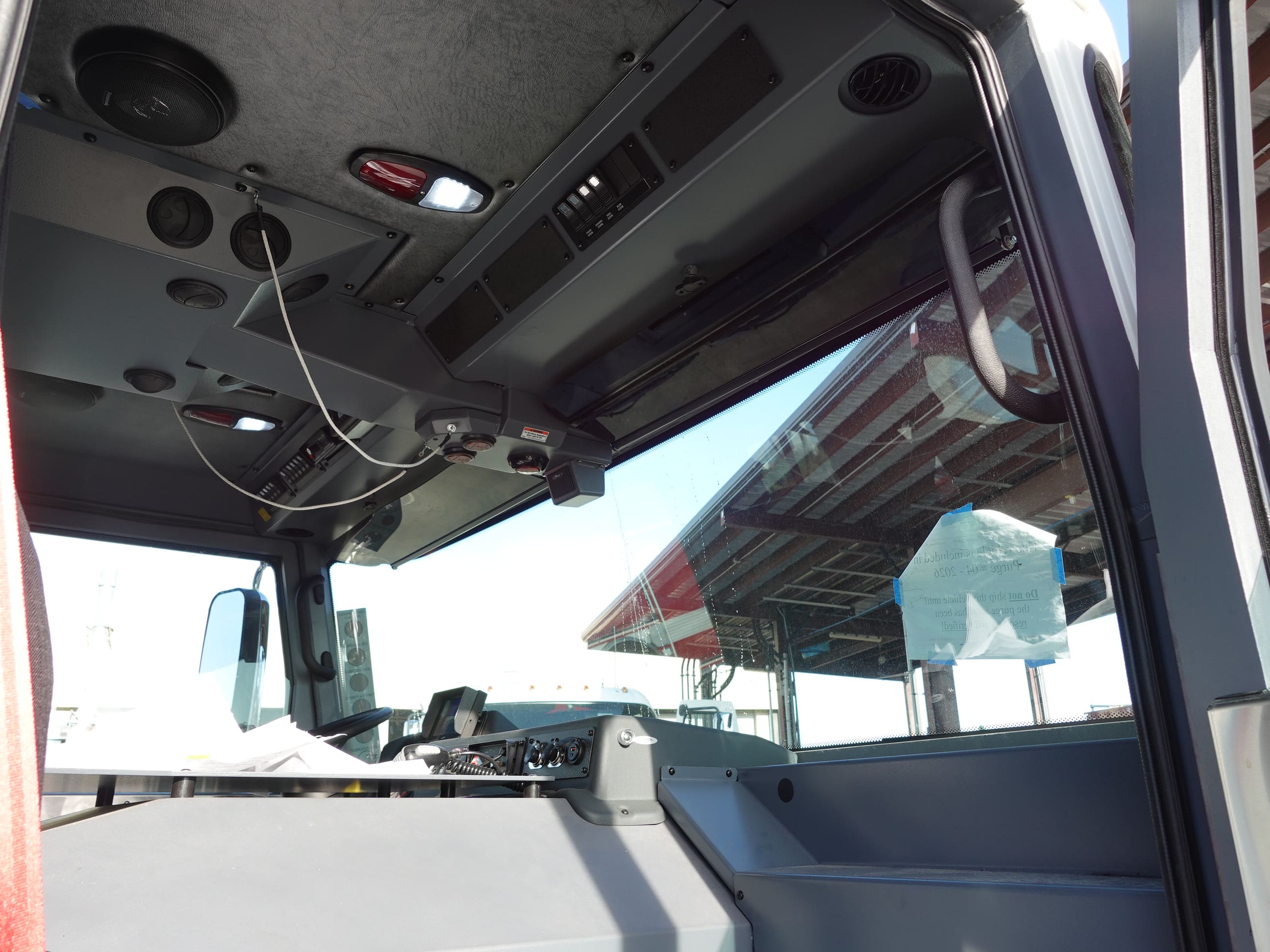

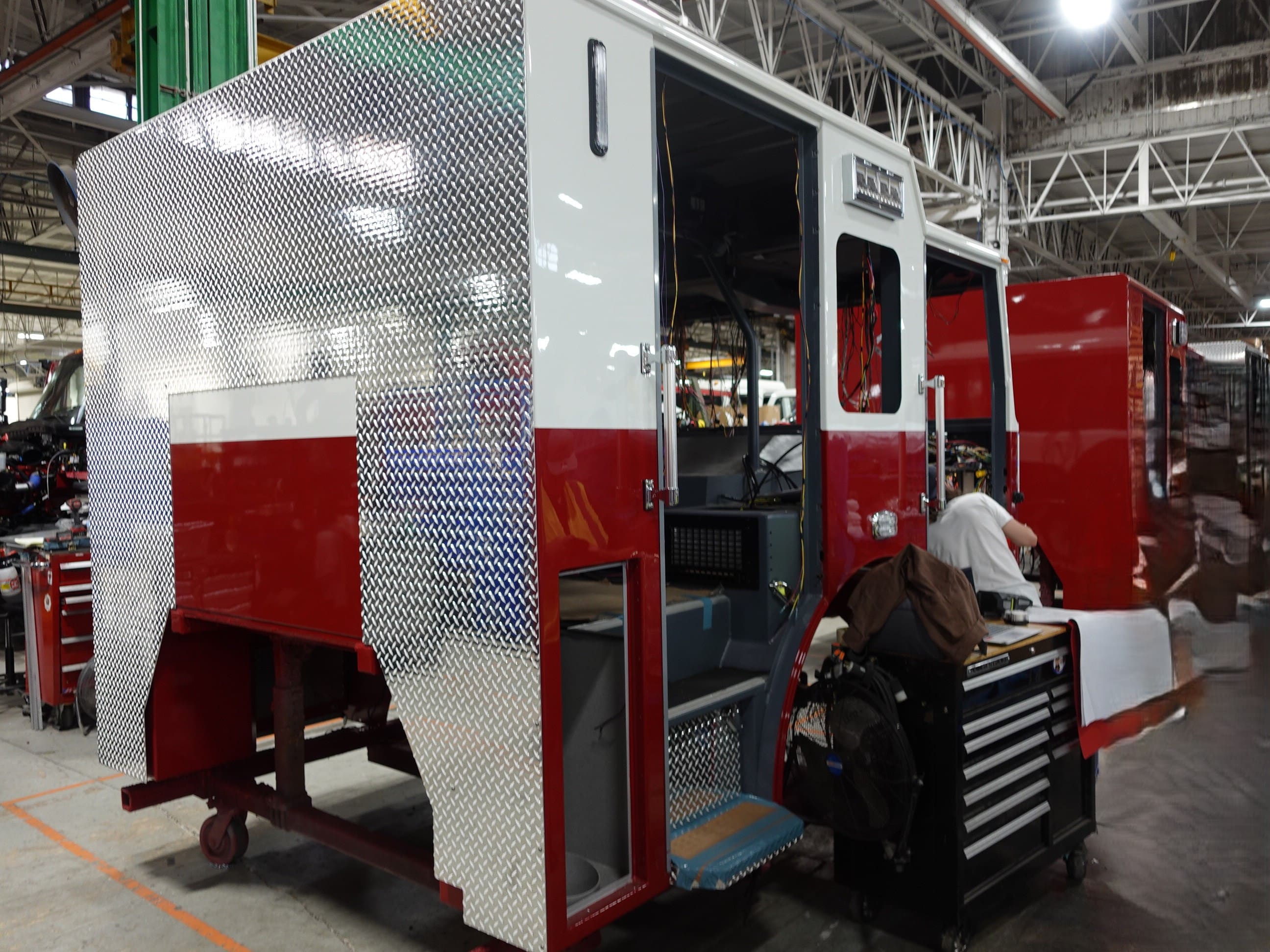

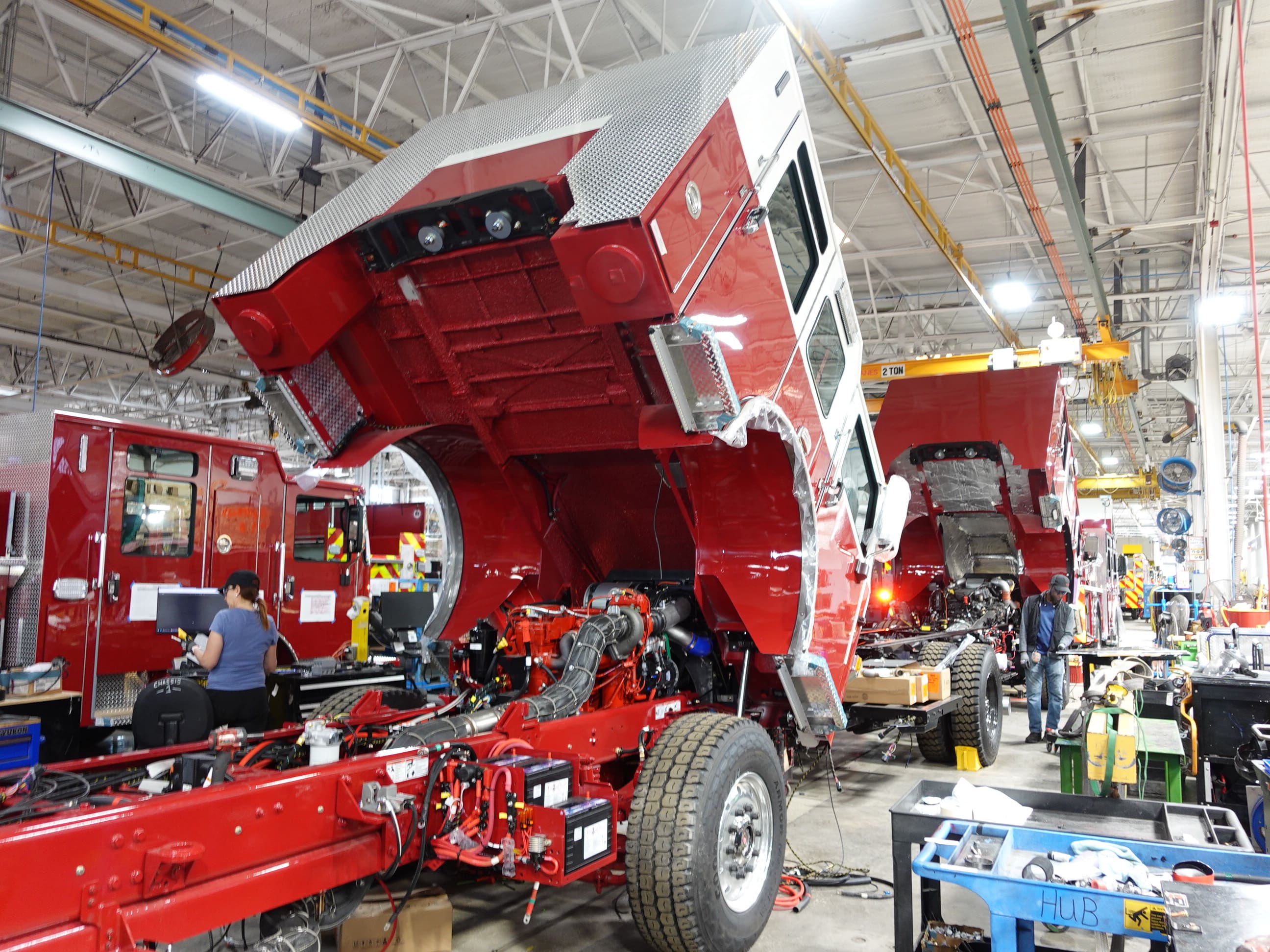

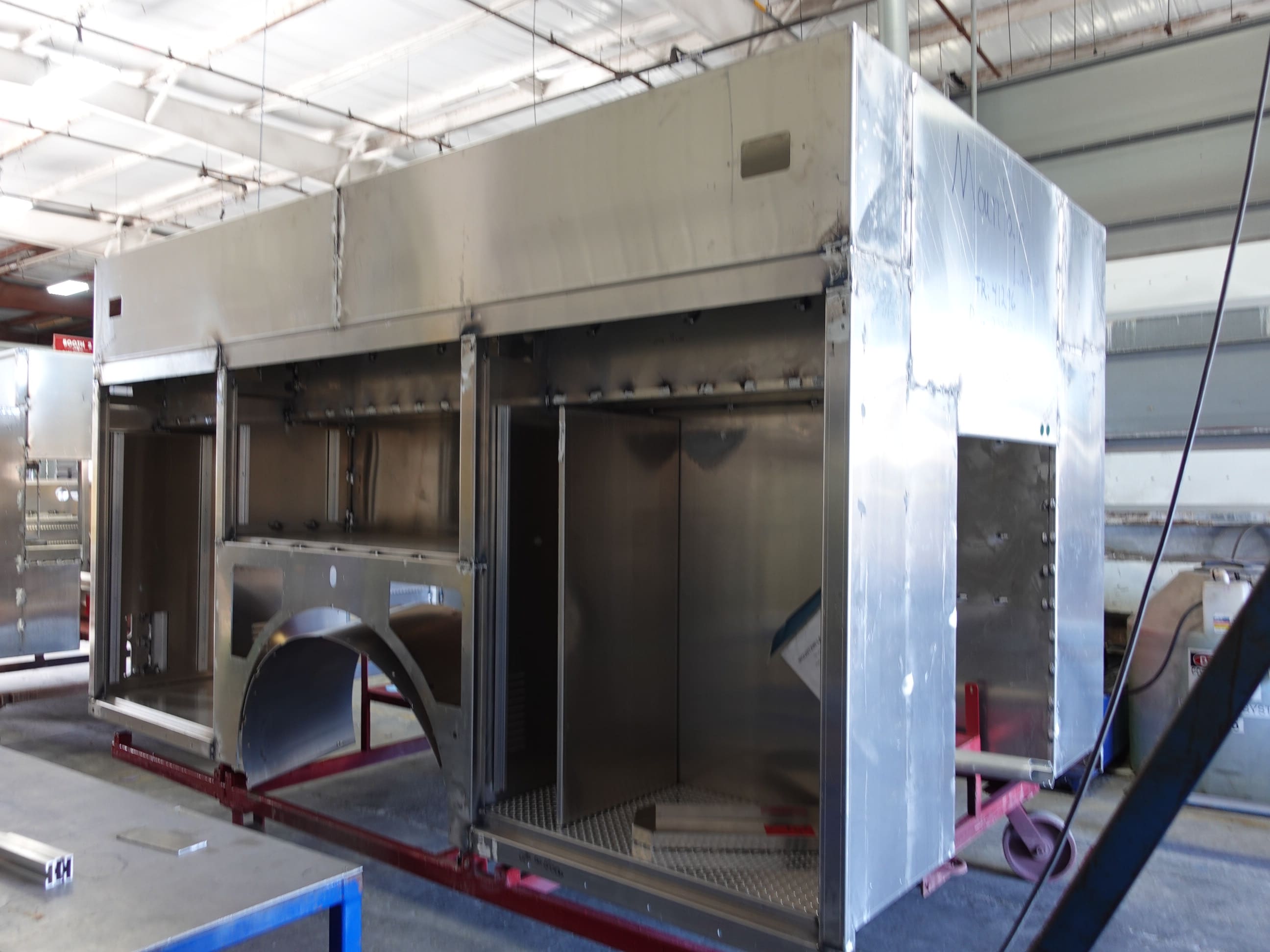

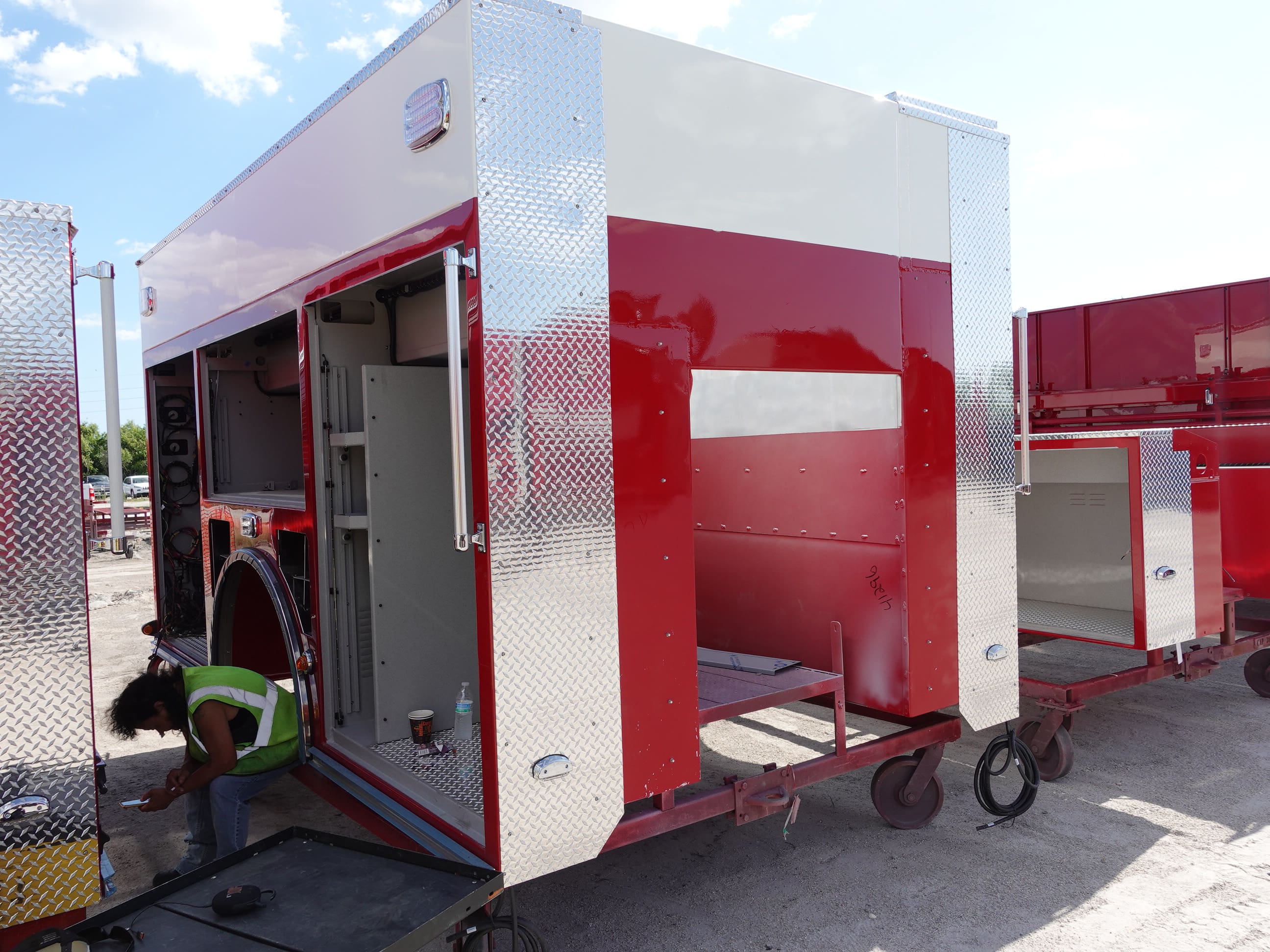

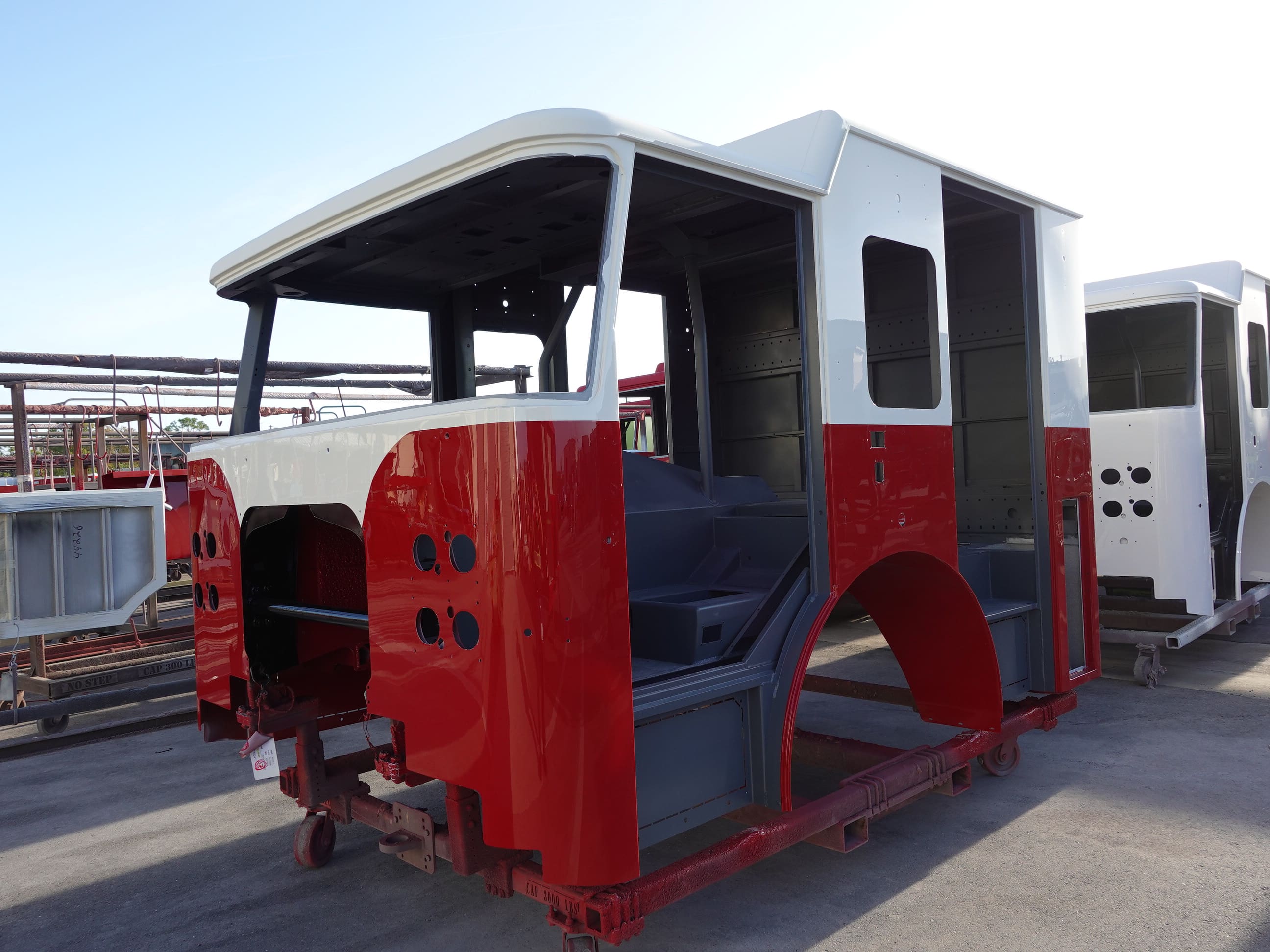

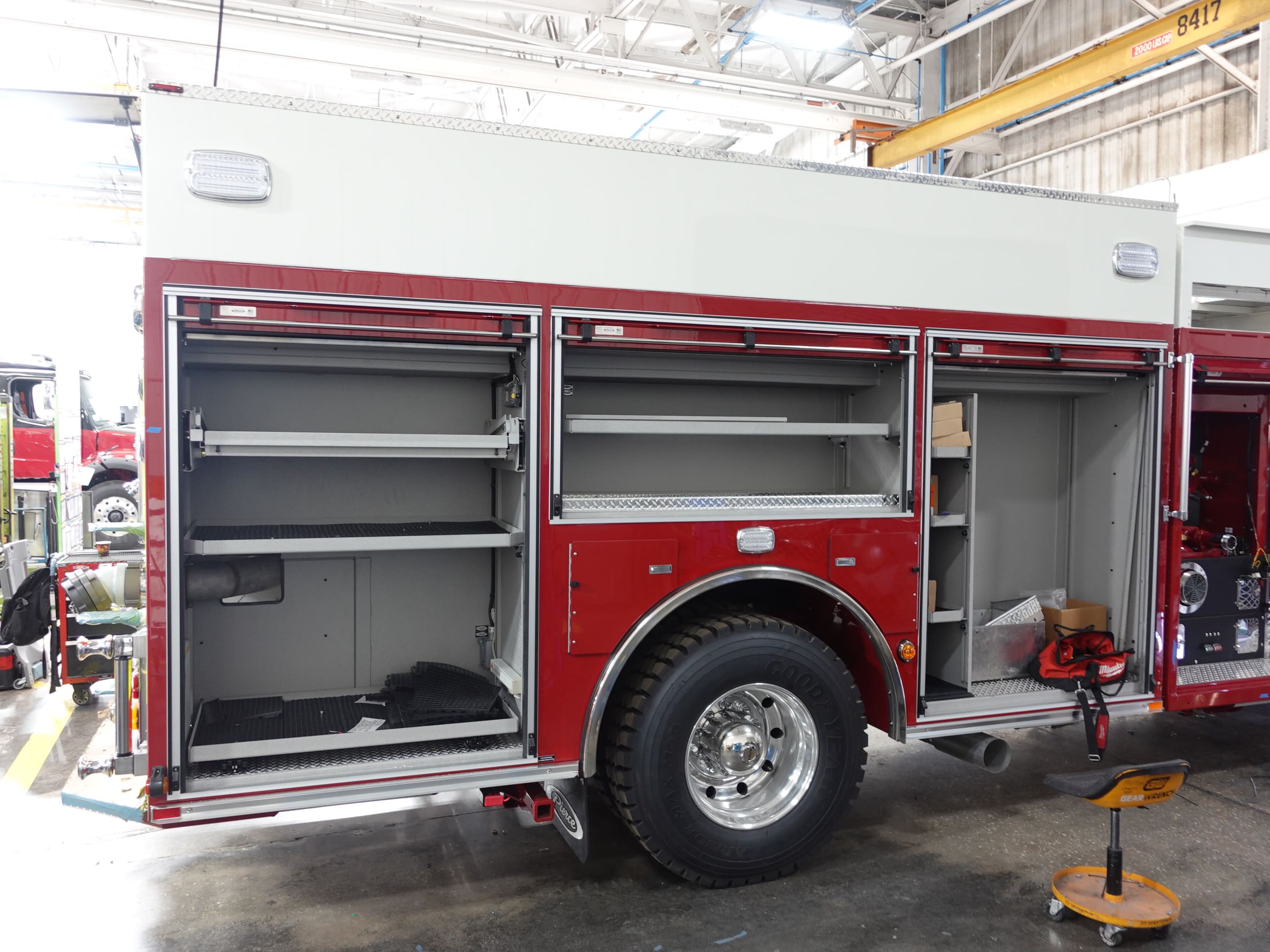

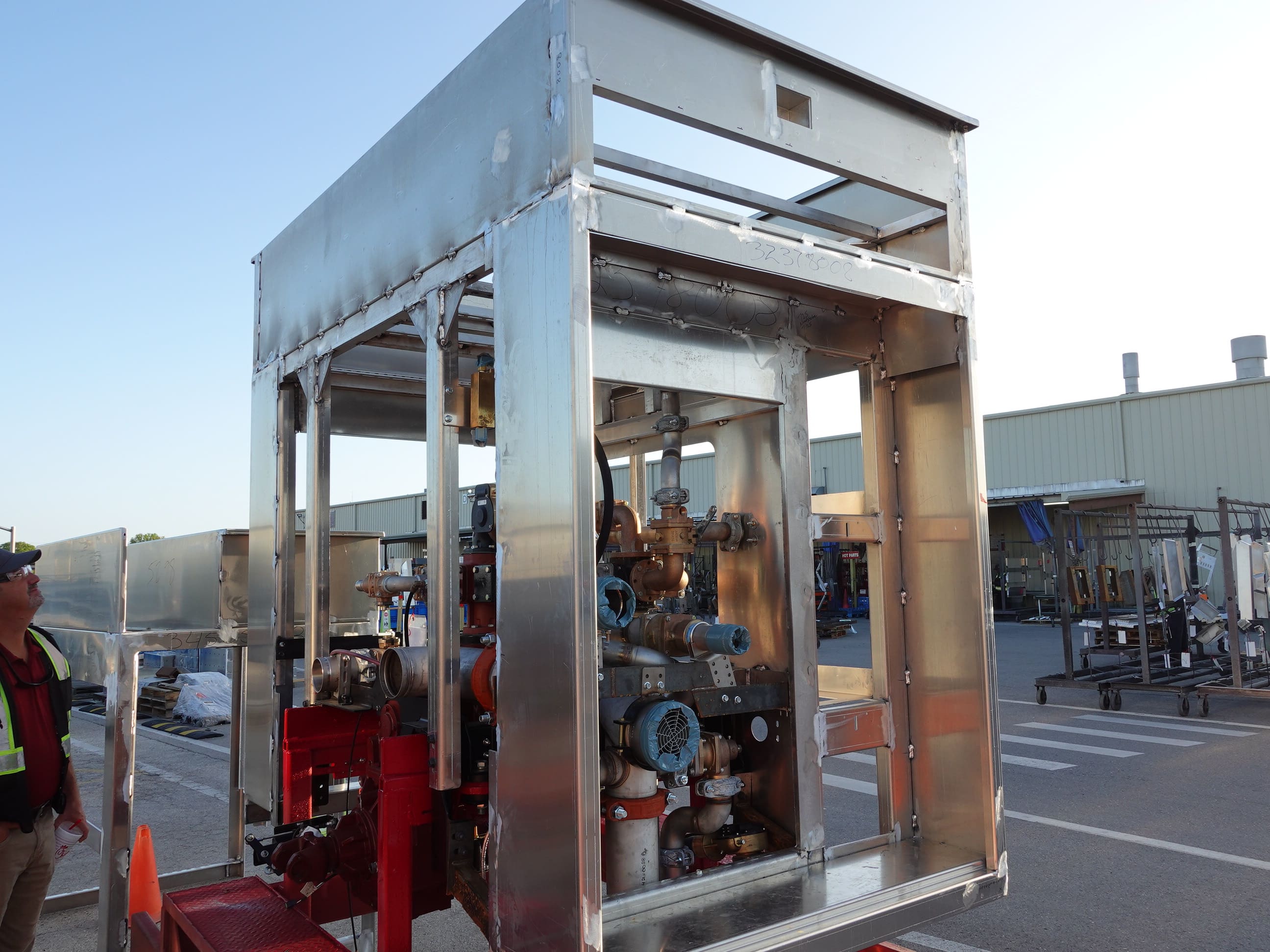

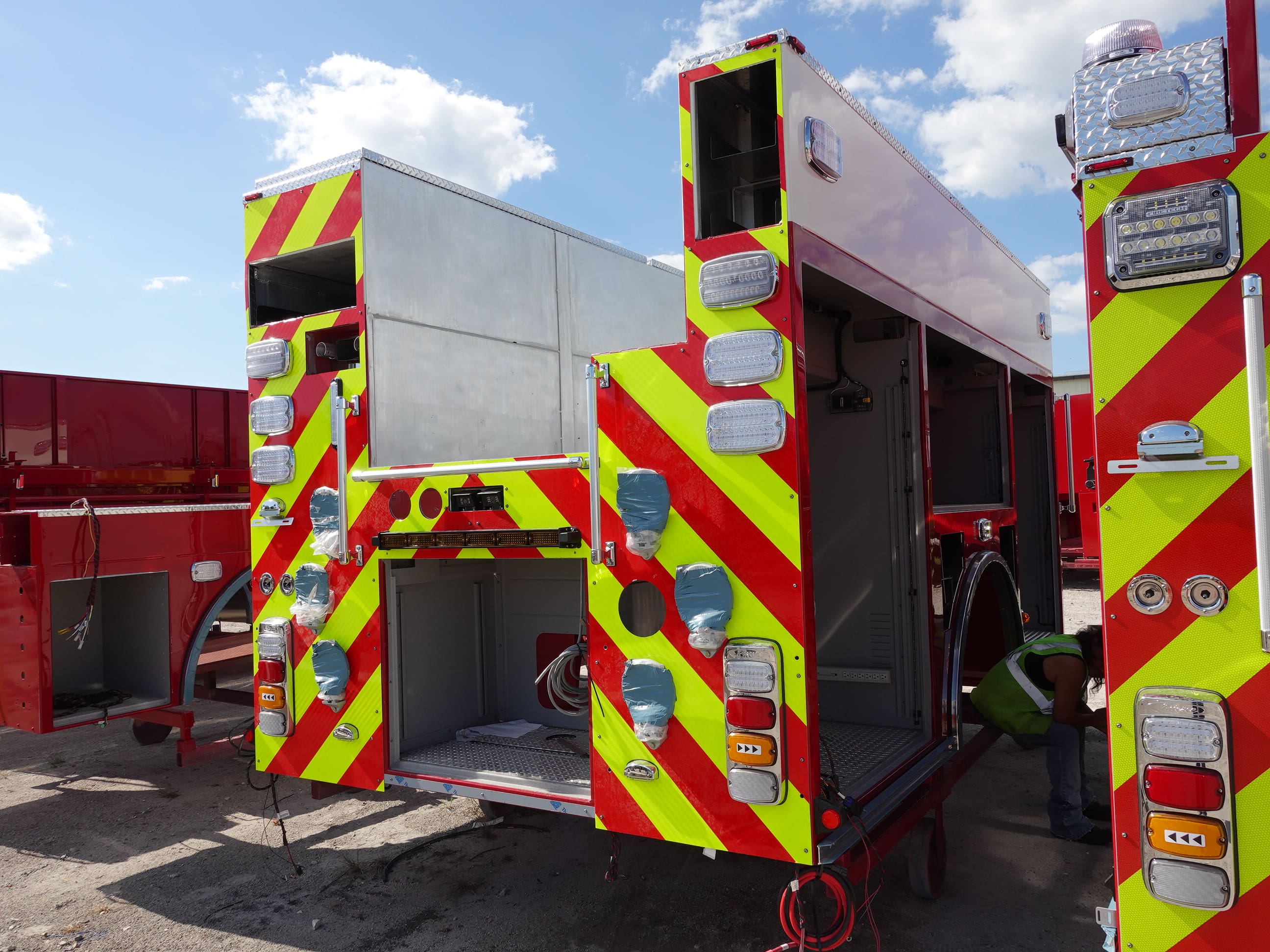

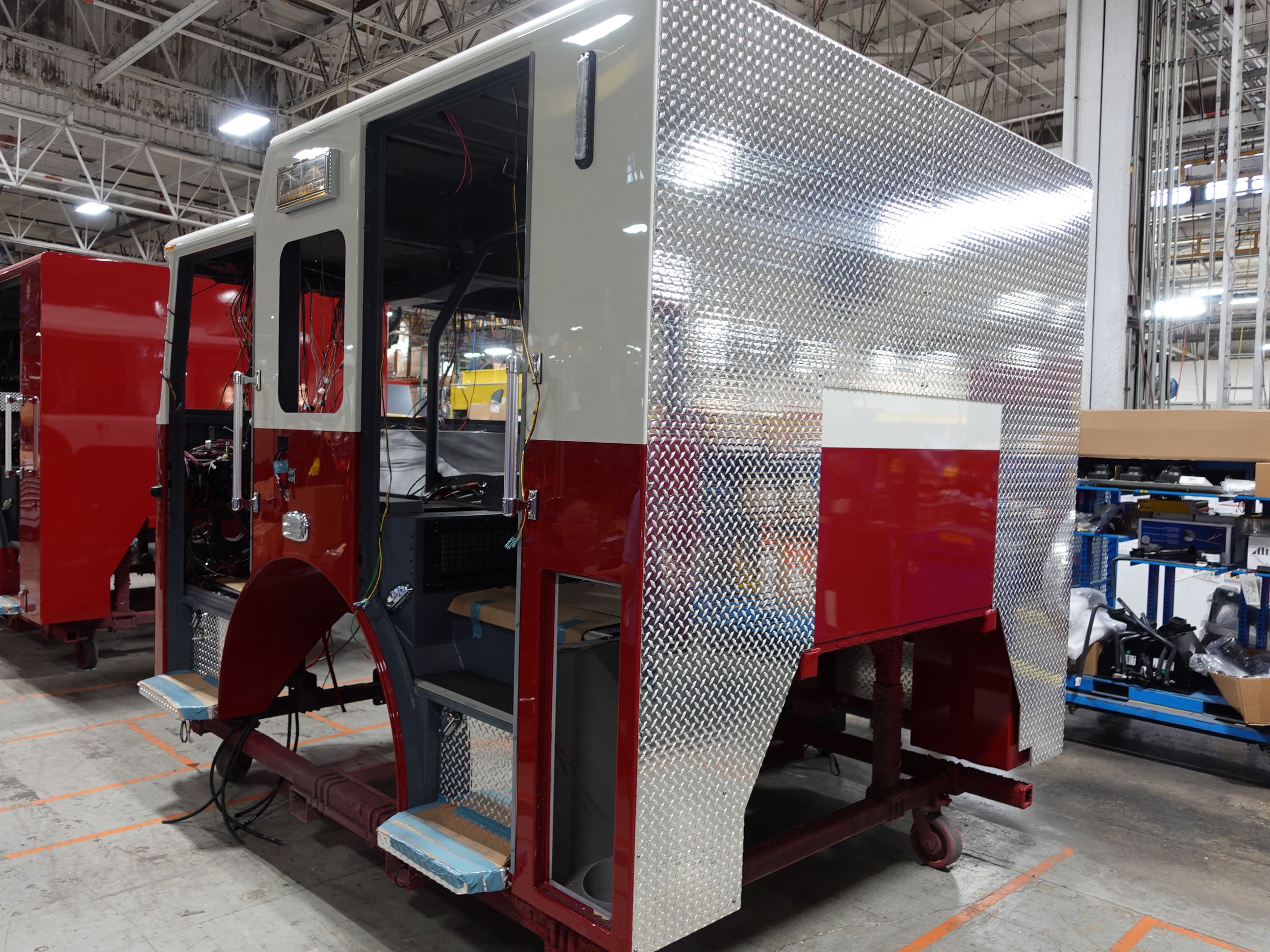

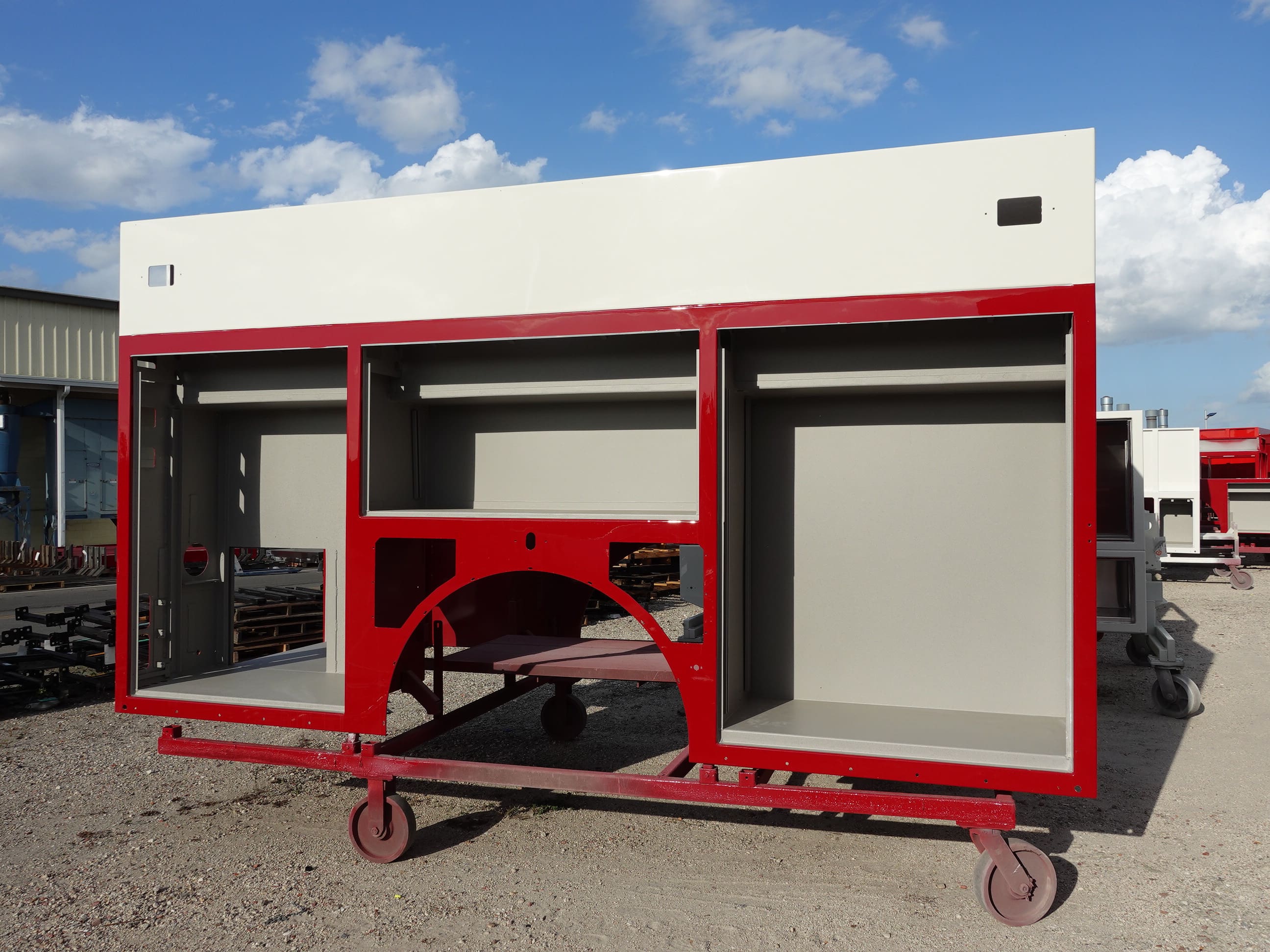

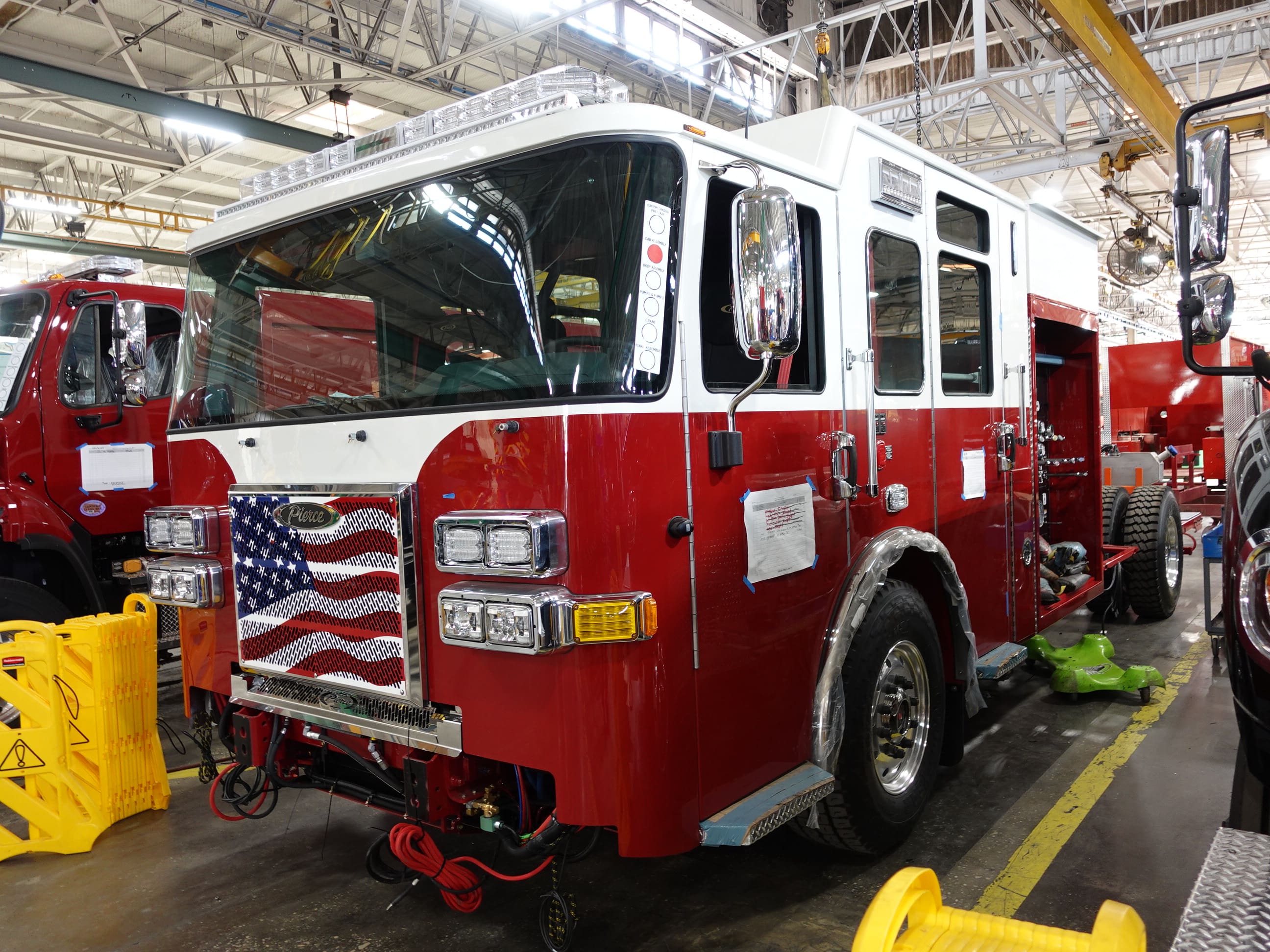

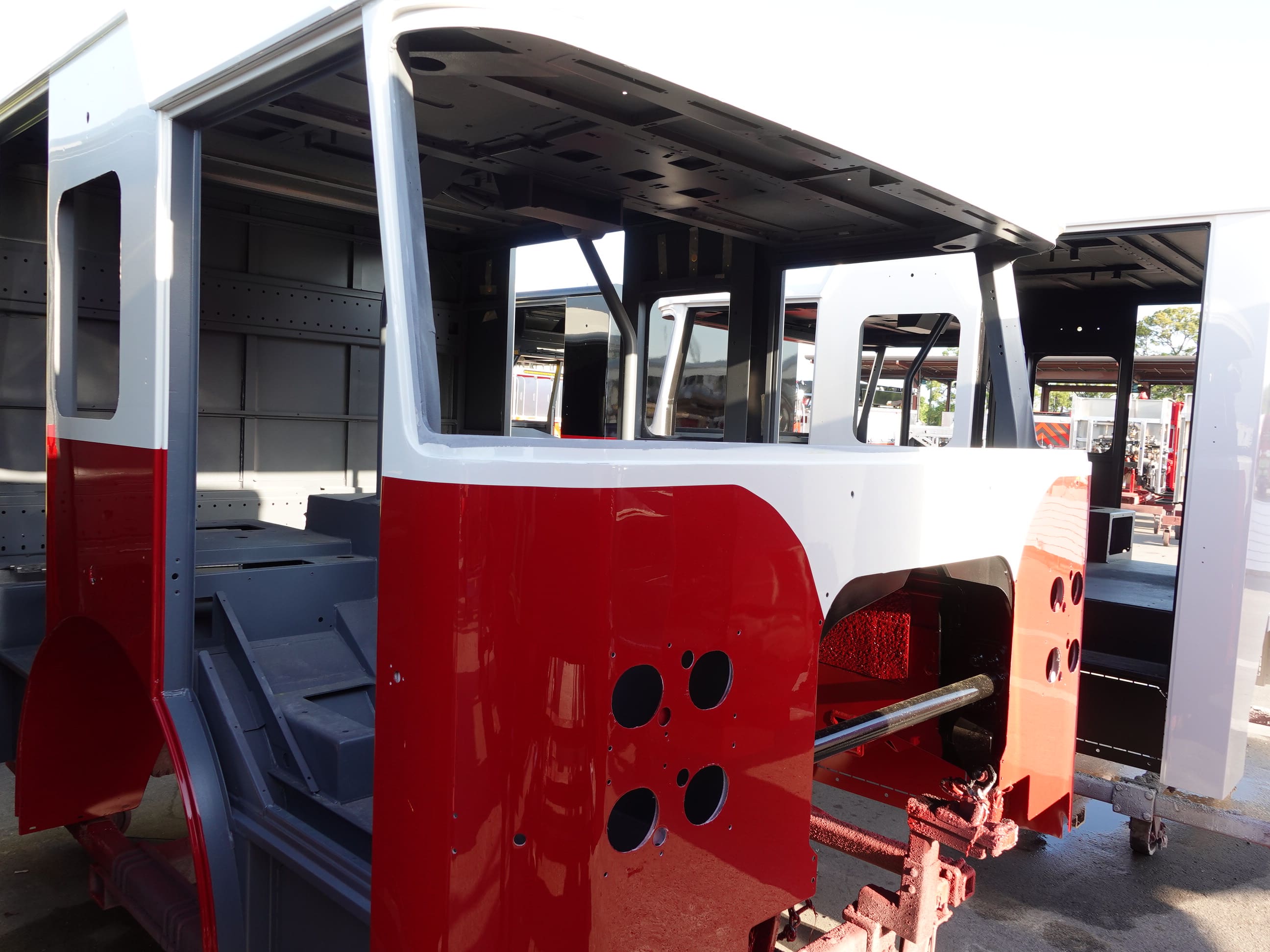

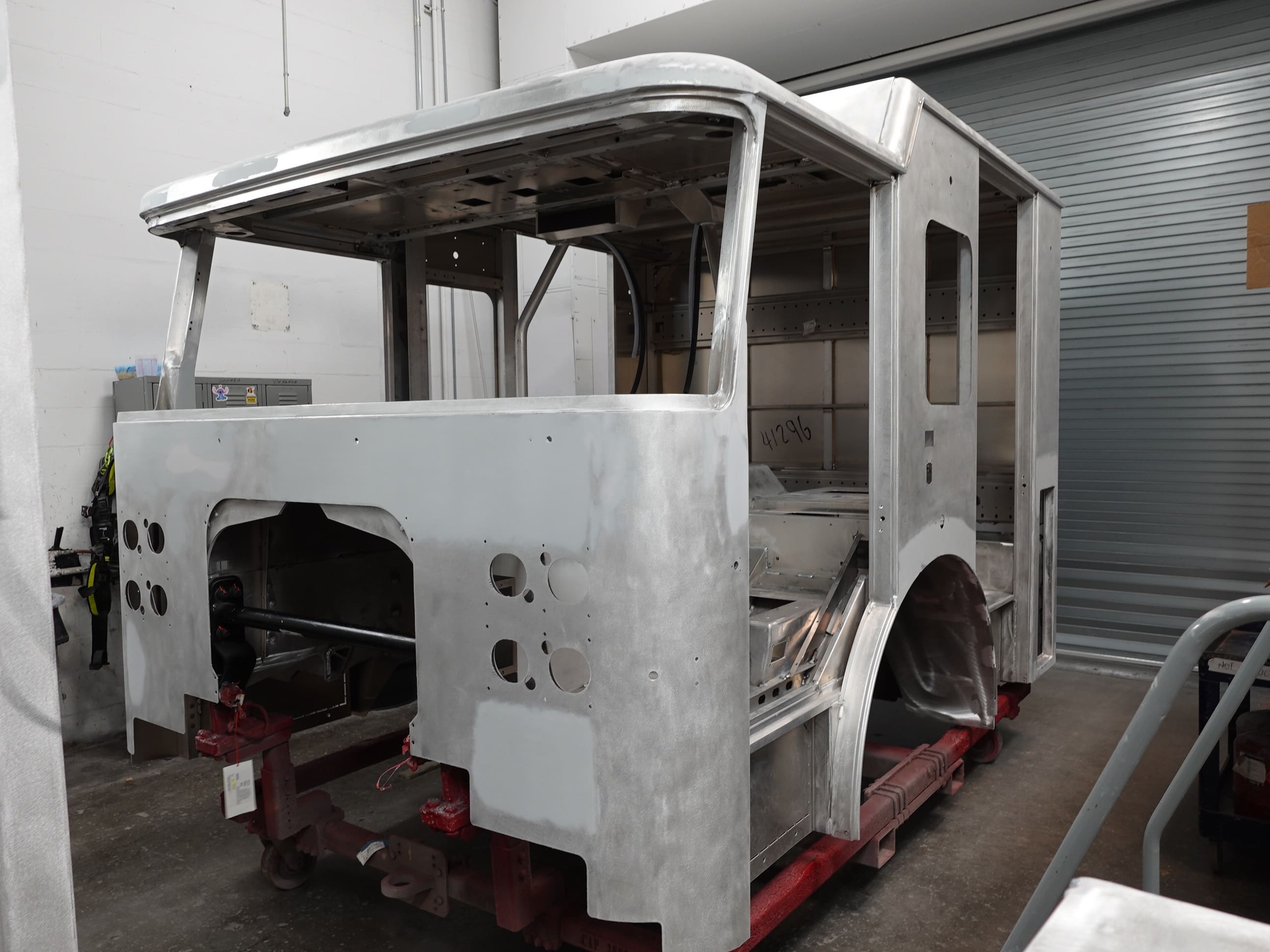

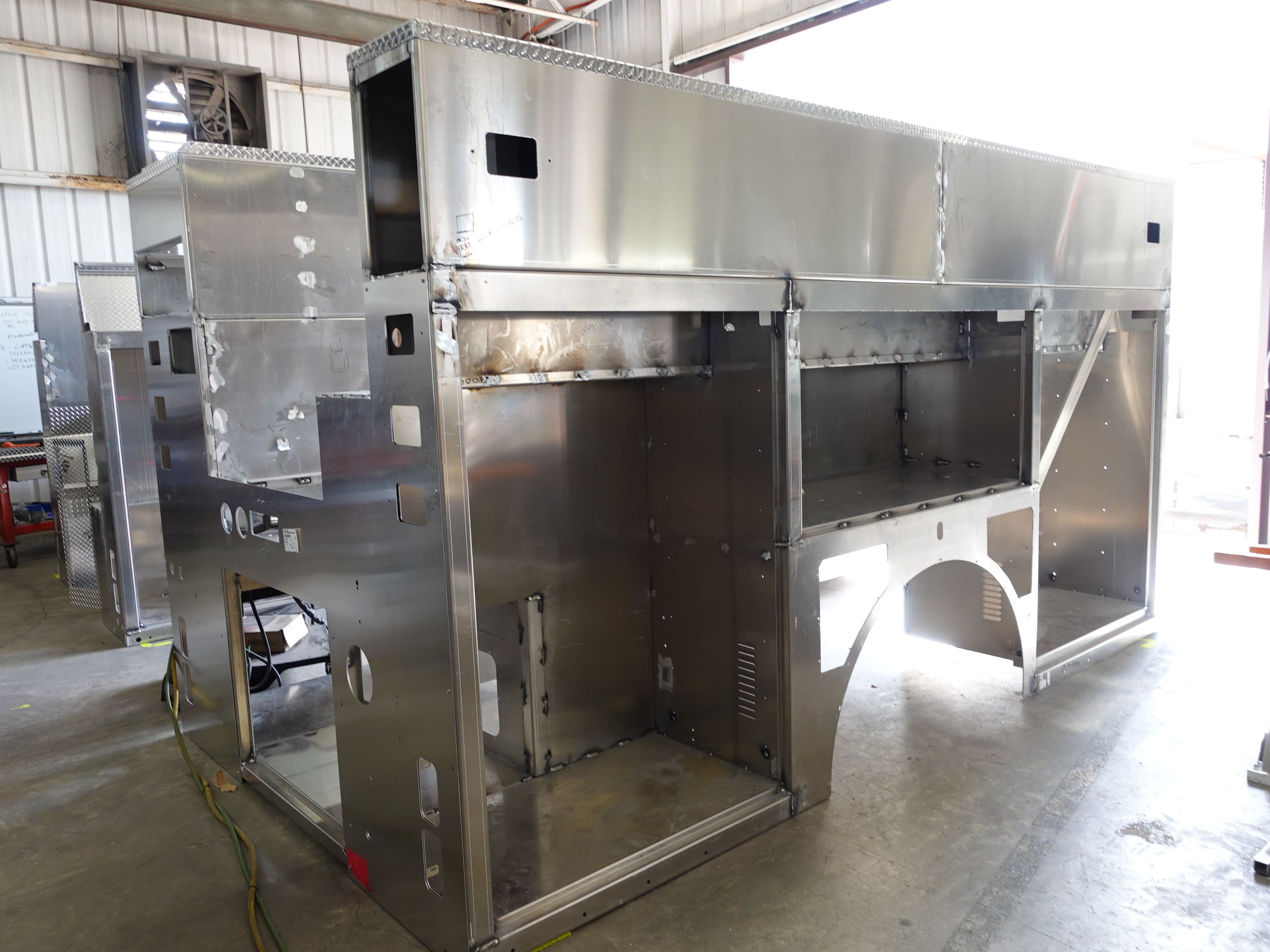

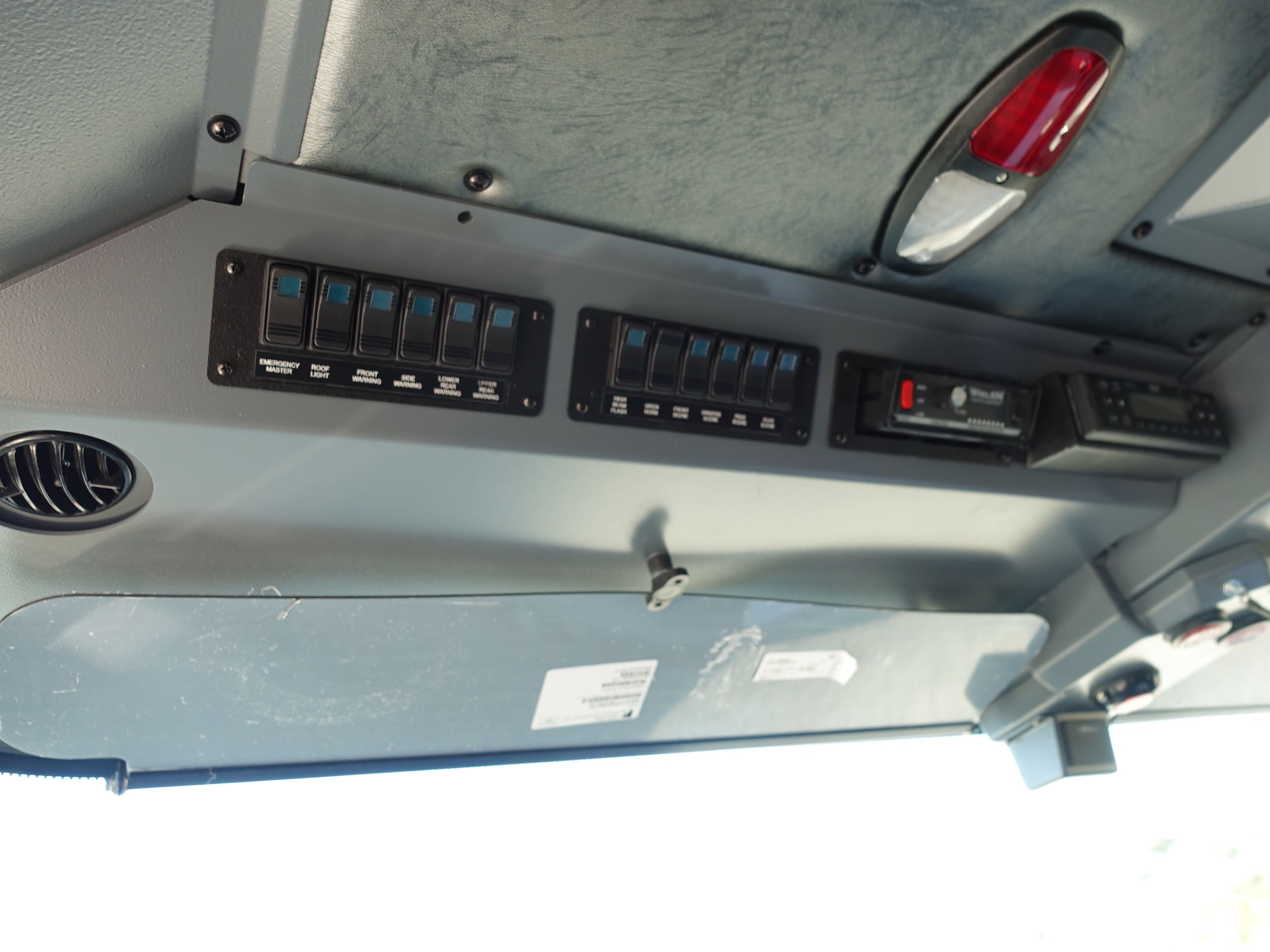

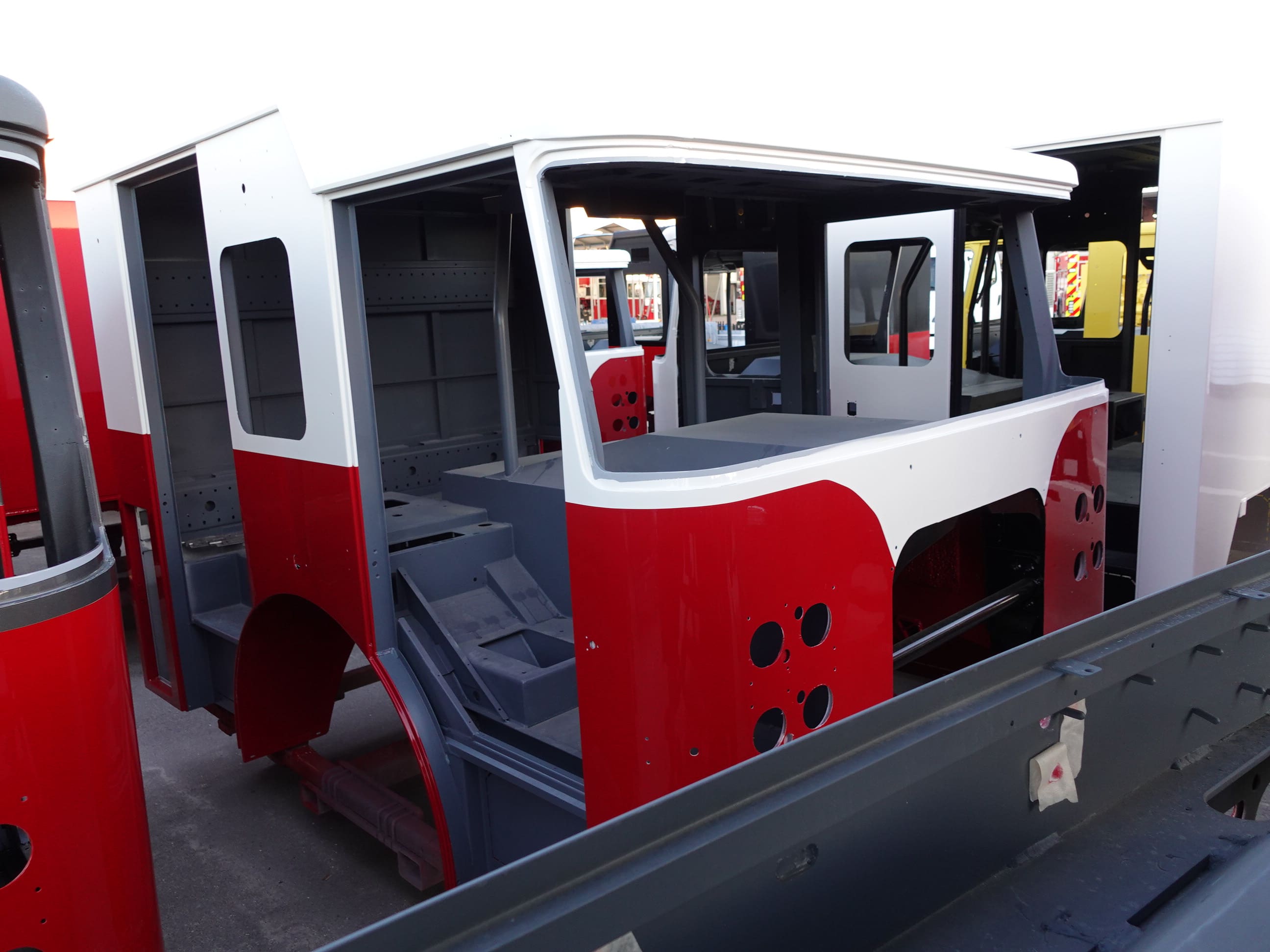

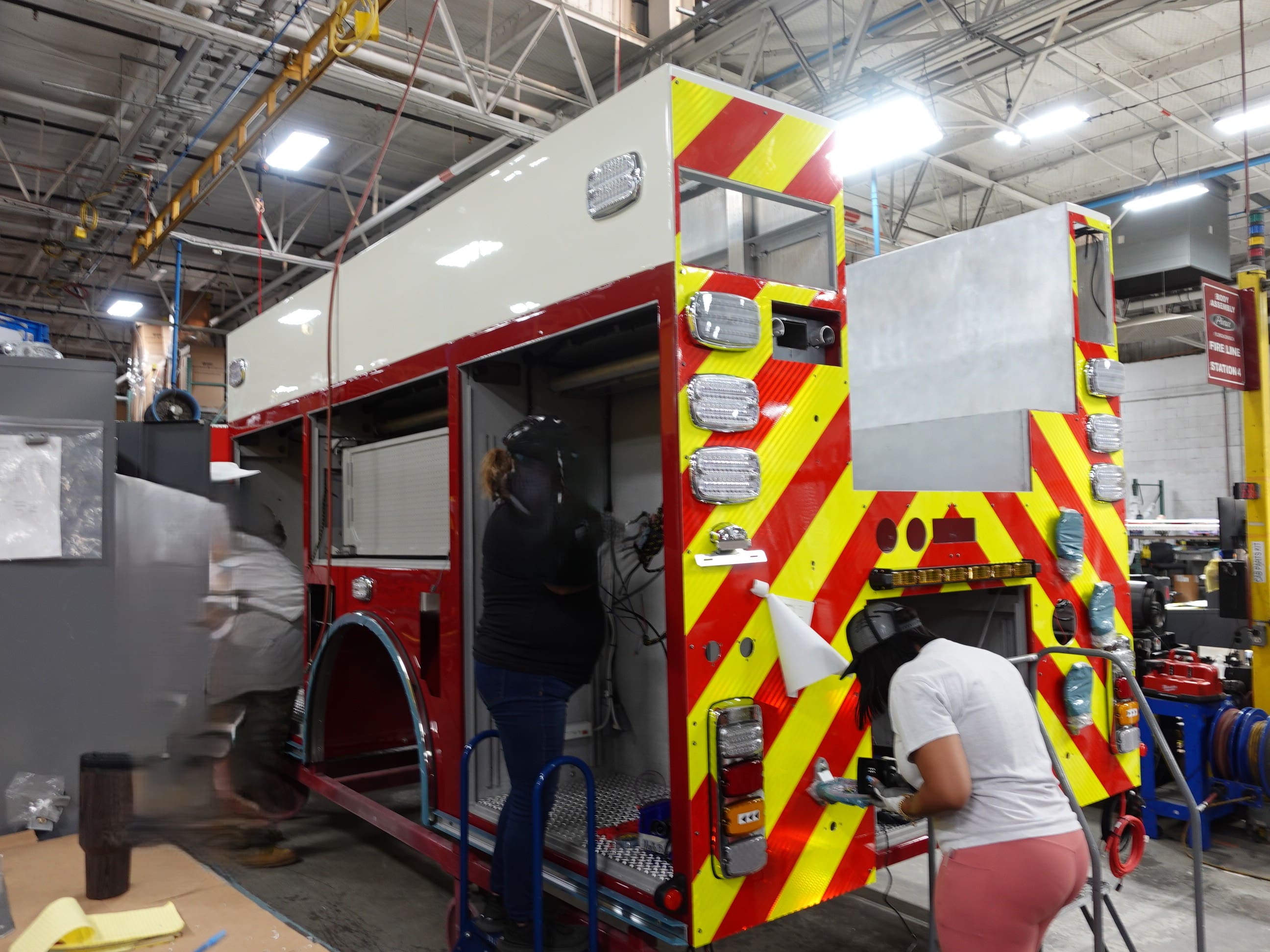

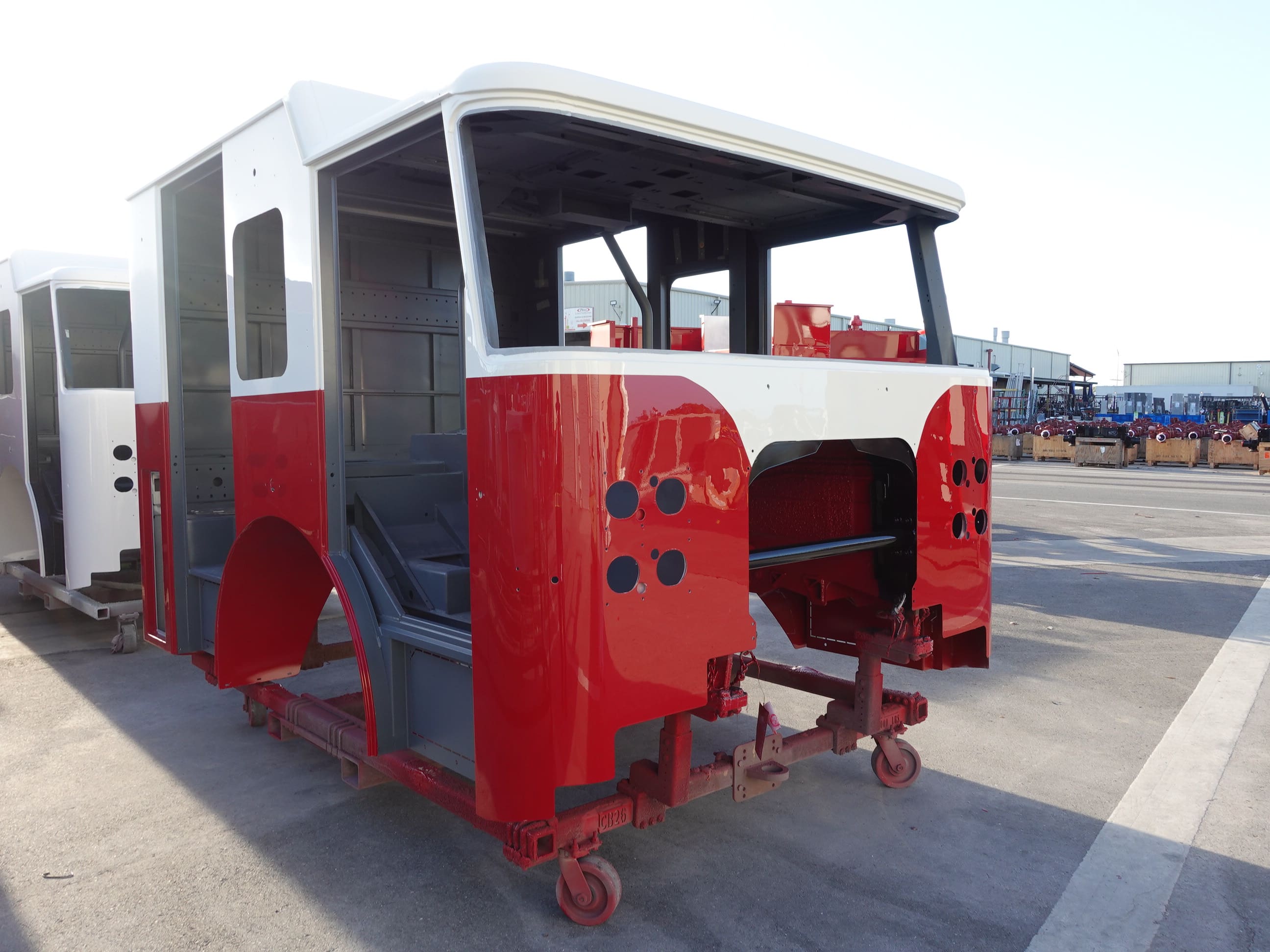

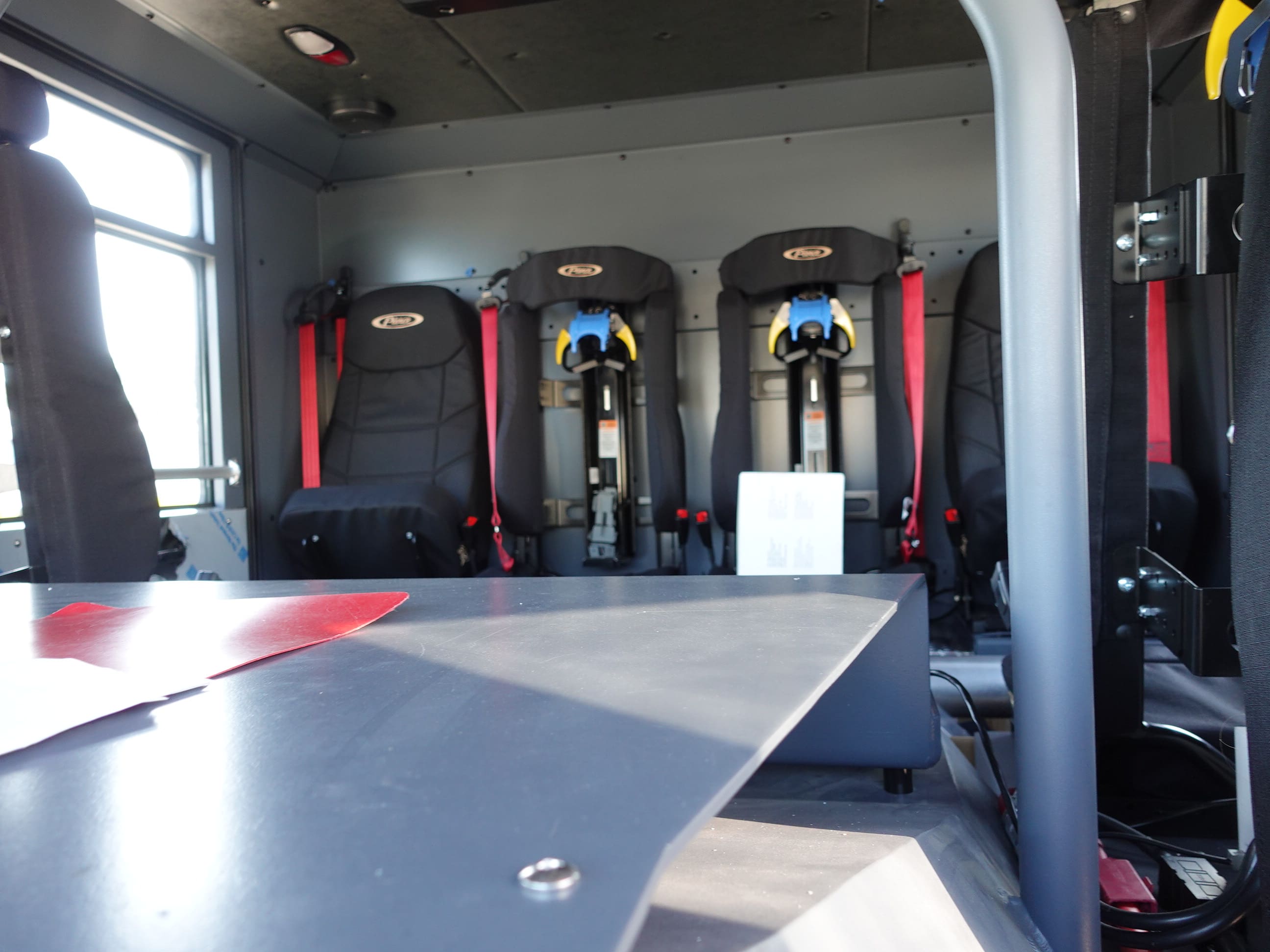

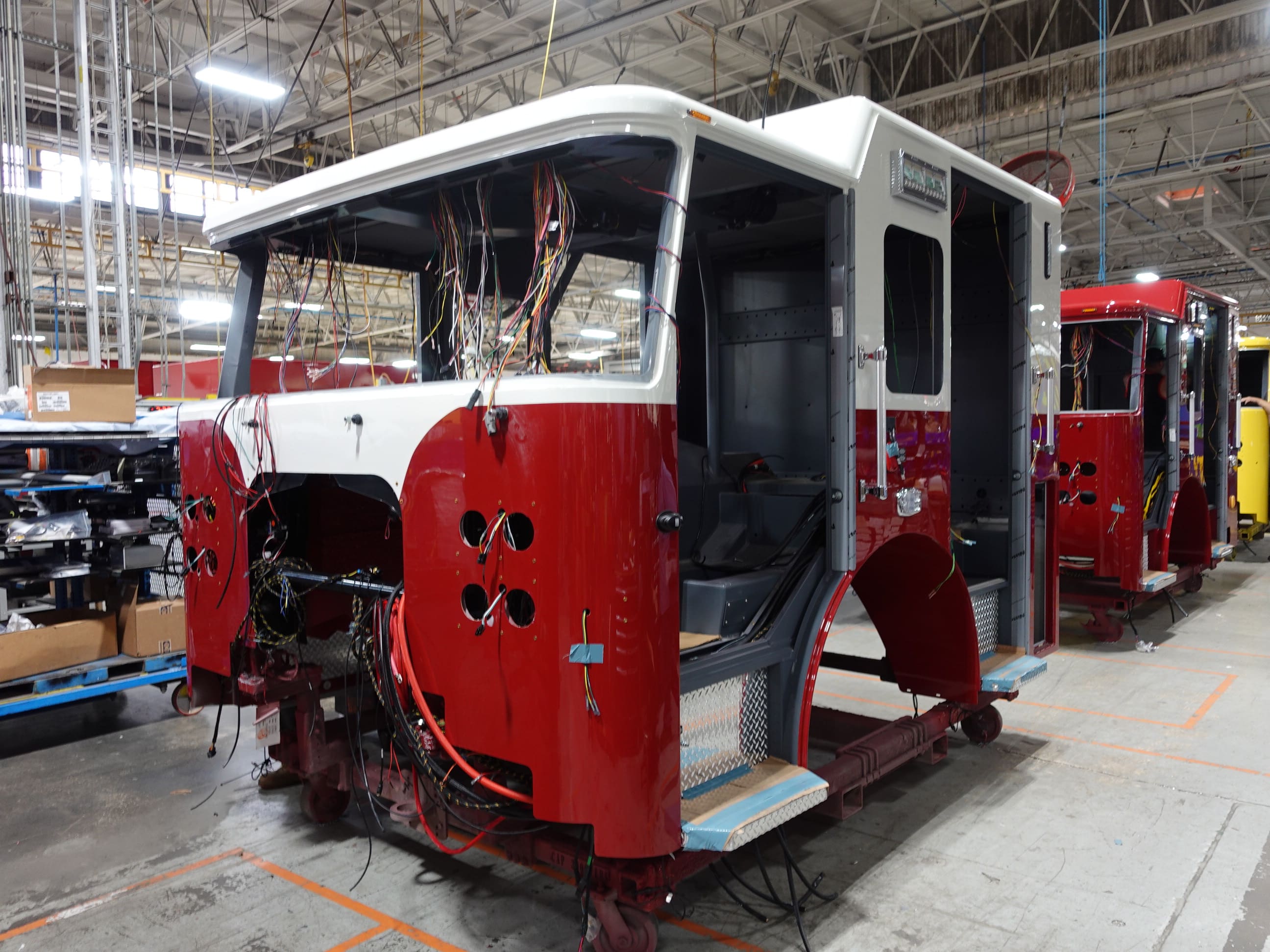

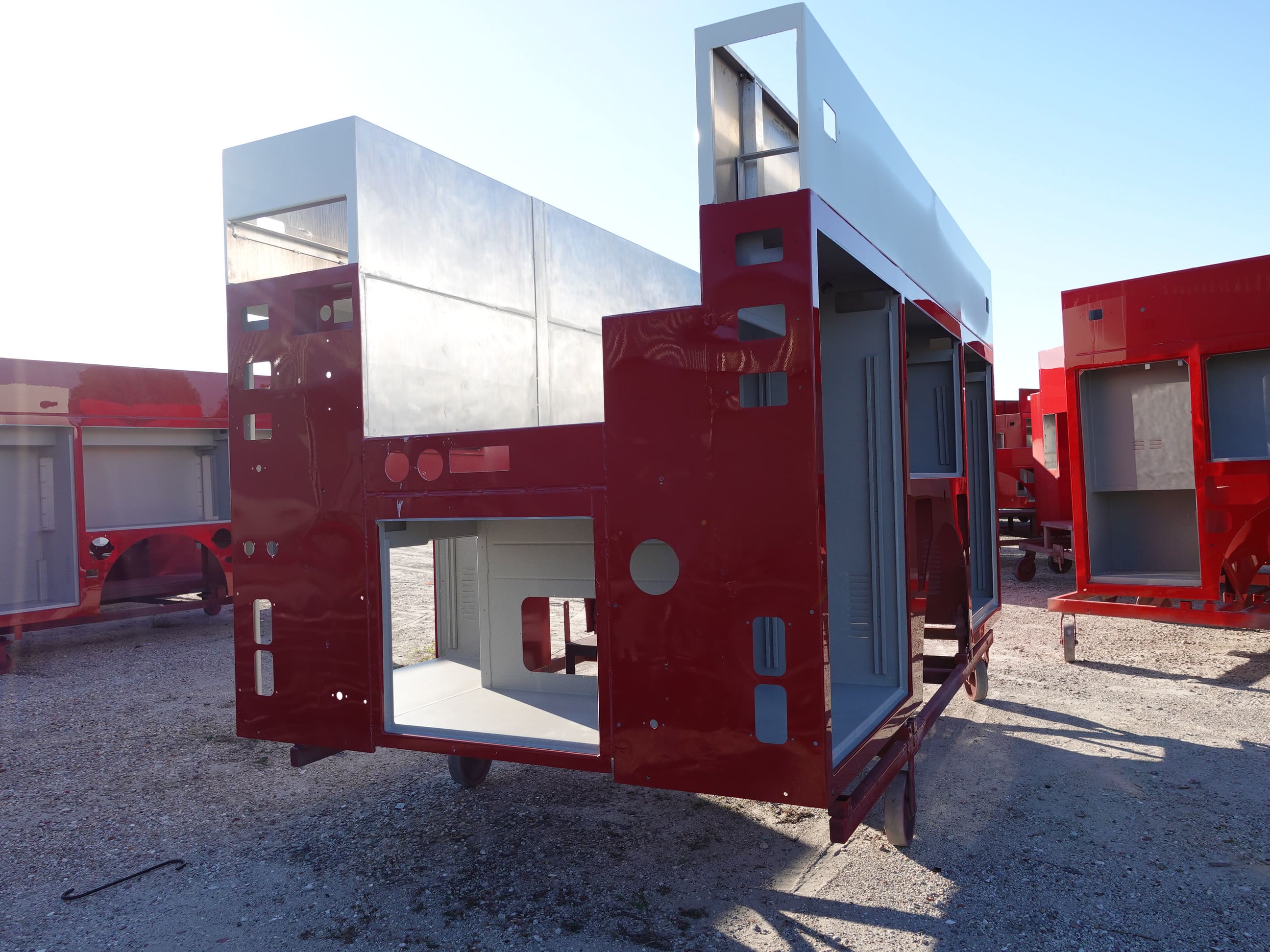

In this report, the cab completed initial assembly and was merged with the frame, the pump house continued initial assembly, and the body completed initial assembly.

04-10-26

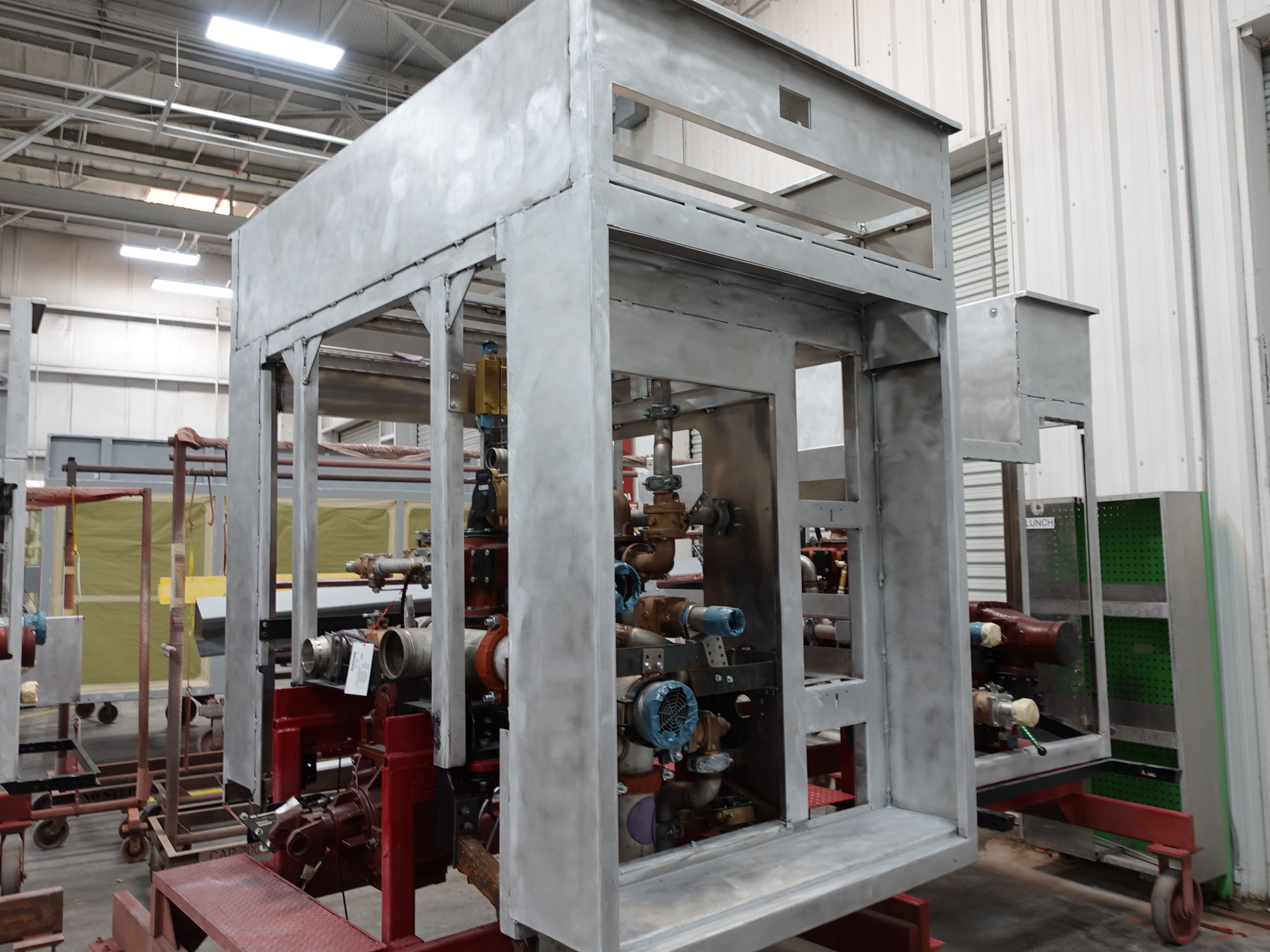

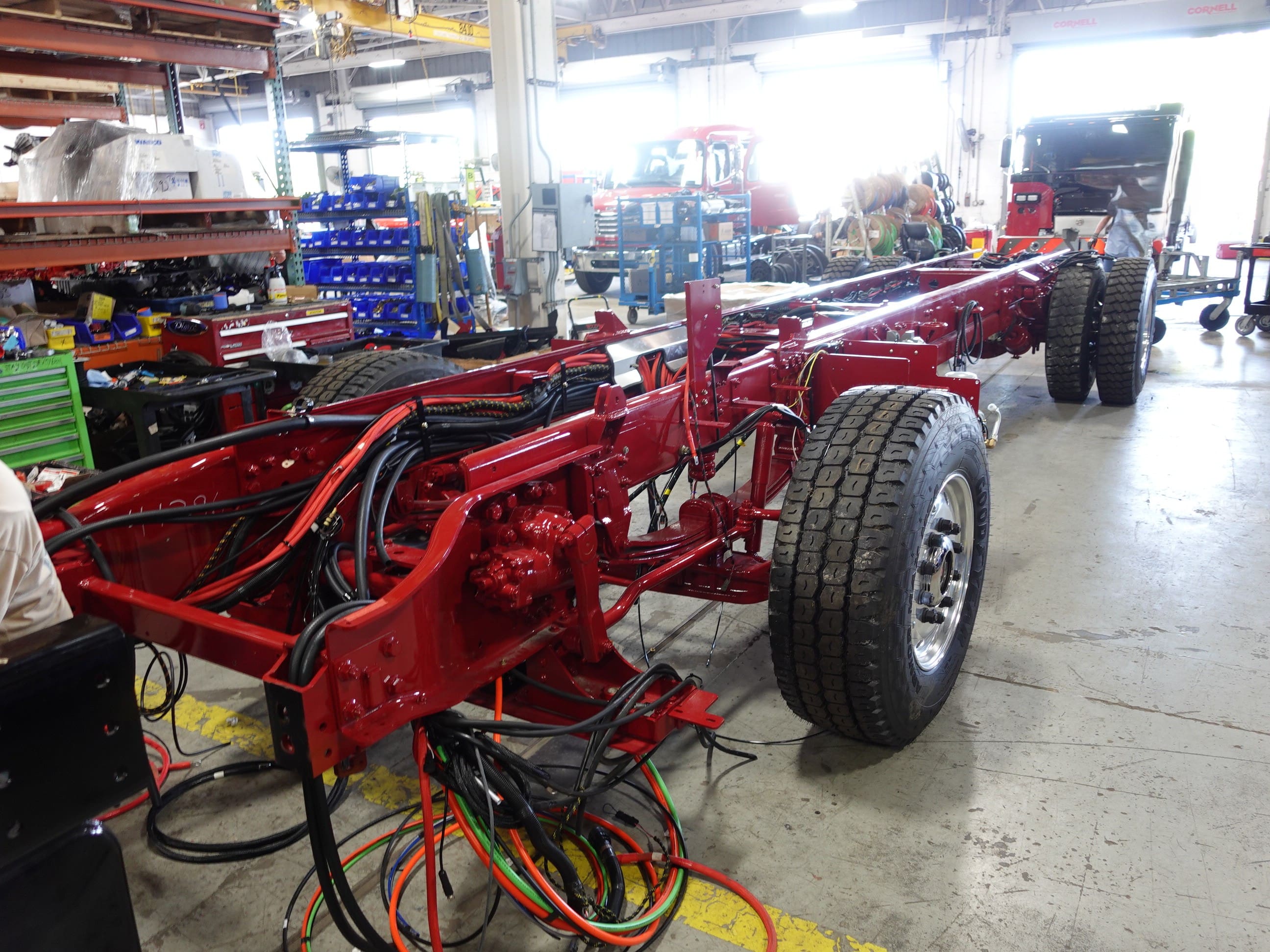

In this report, the cab began initial assembly, the frame build continued, the pump house was painted then continued initial assembly, and the body began initial assembly.

04-03-26

In this report, the cab and frame remained staged (no photos), the pump house continued through paint, and the body was staged.

03-27-26

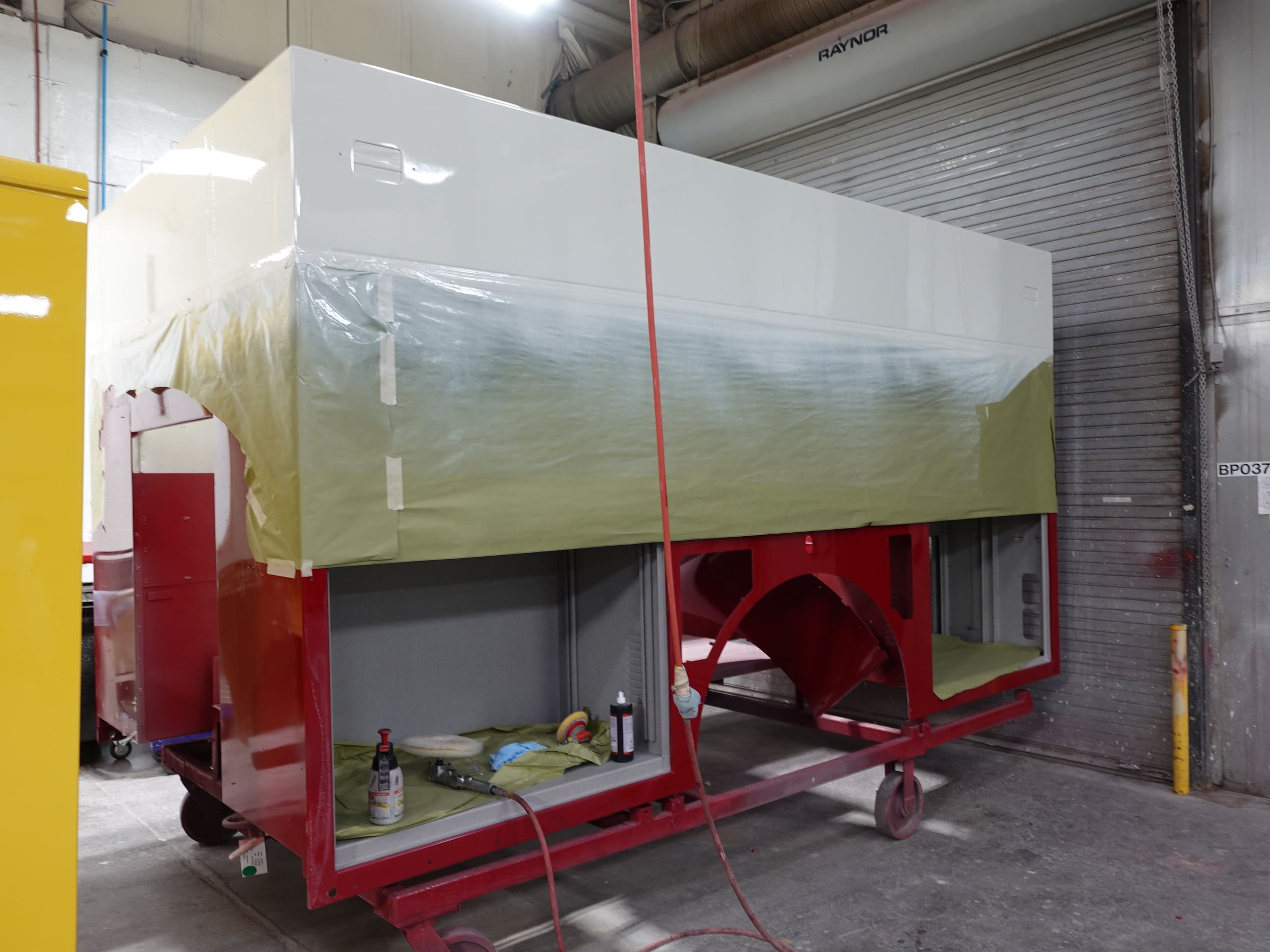

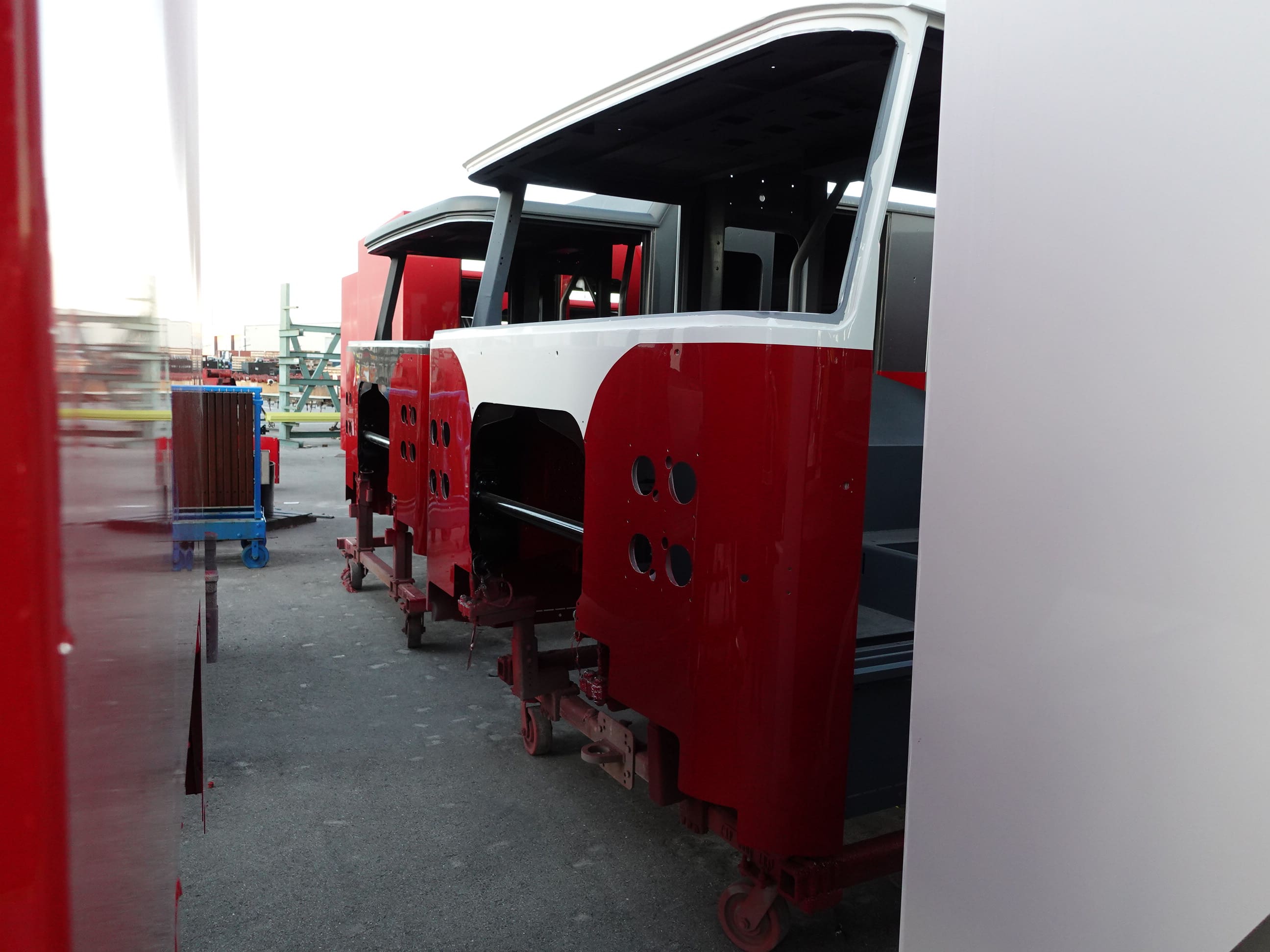

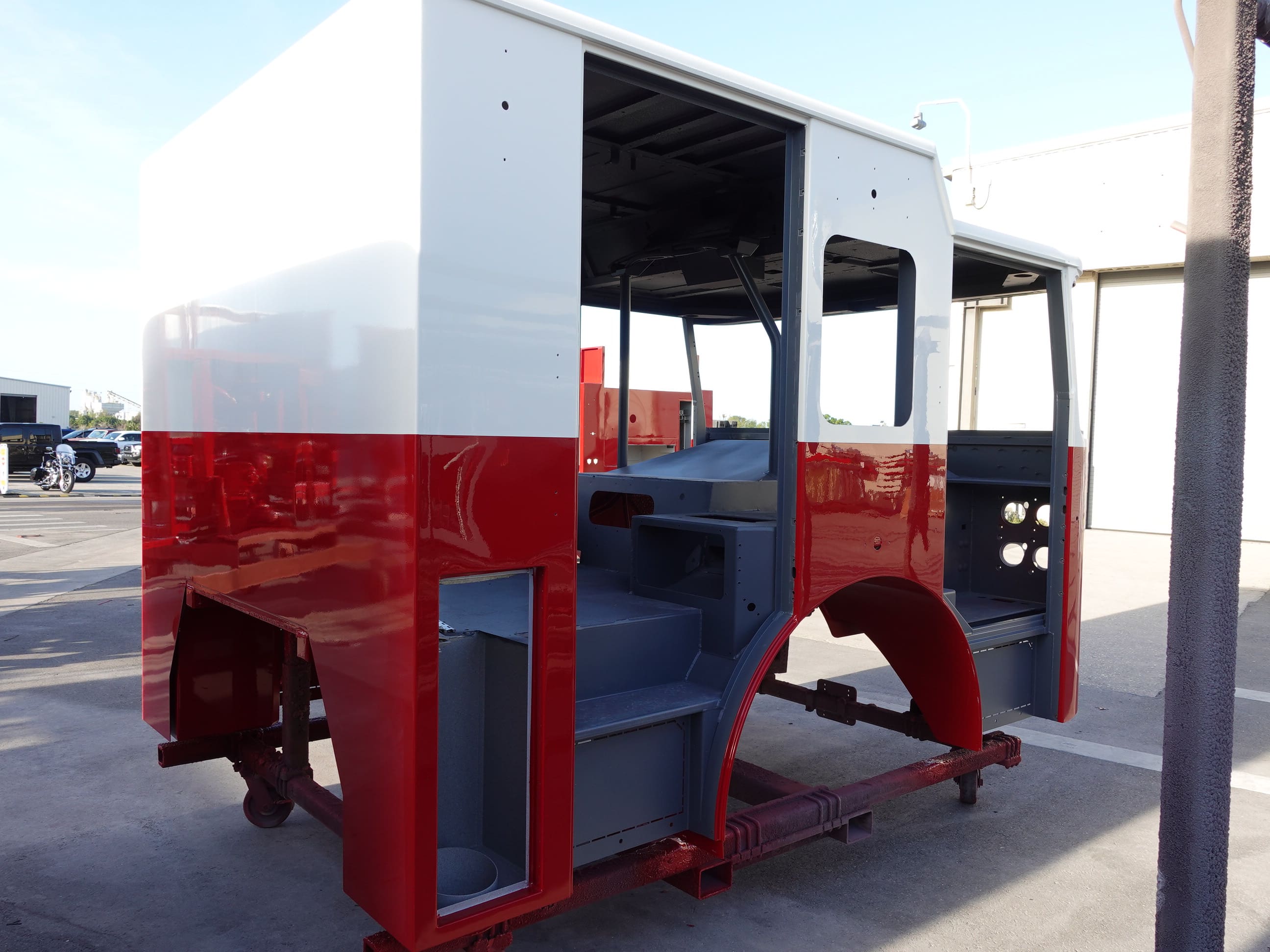

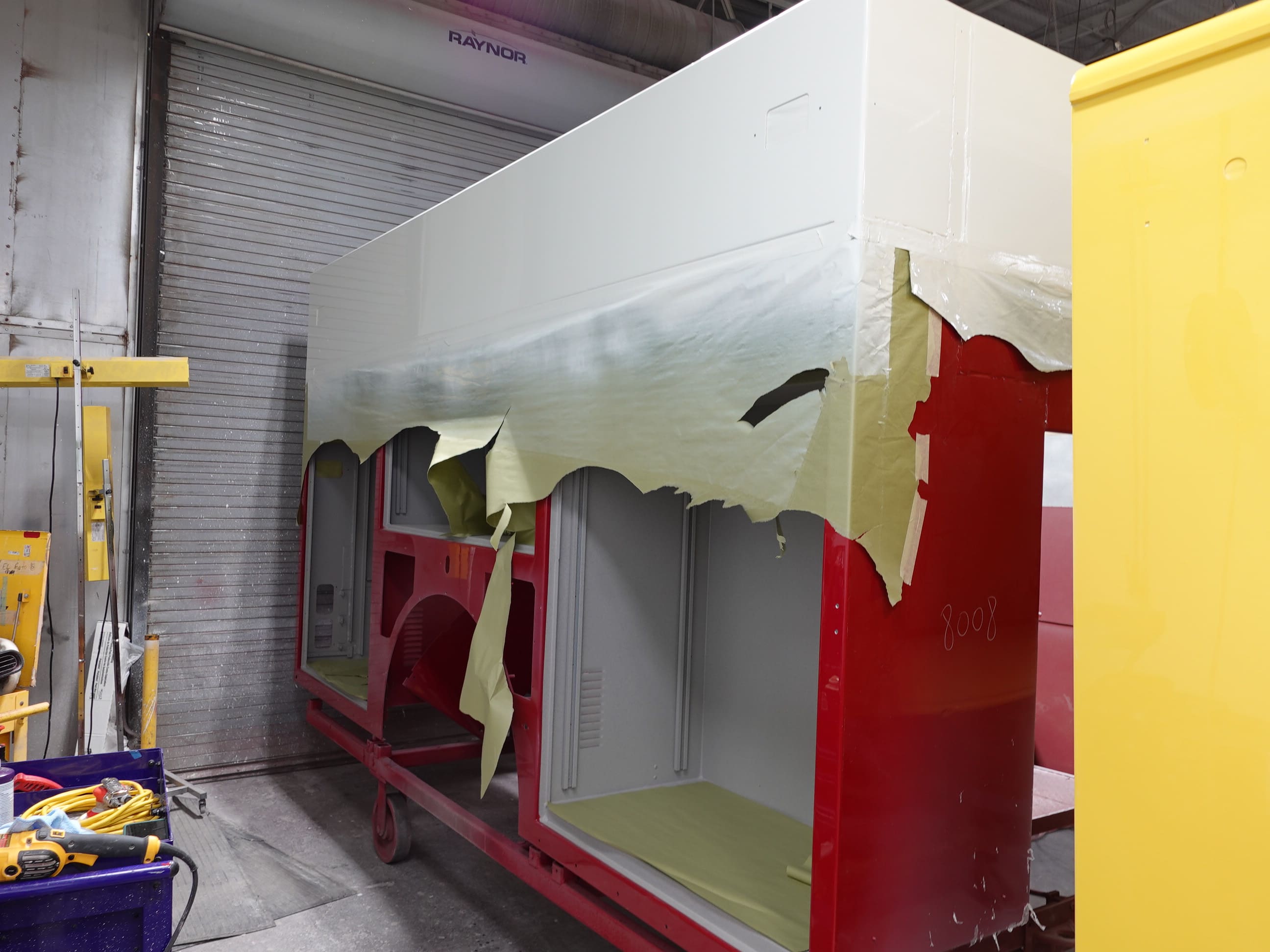

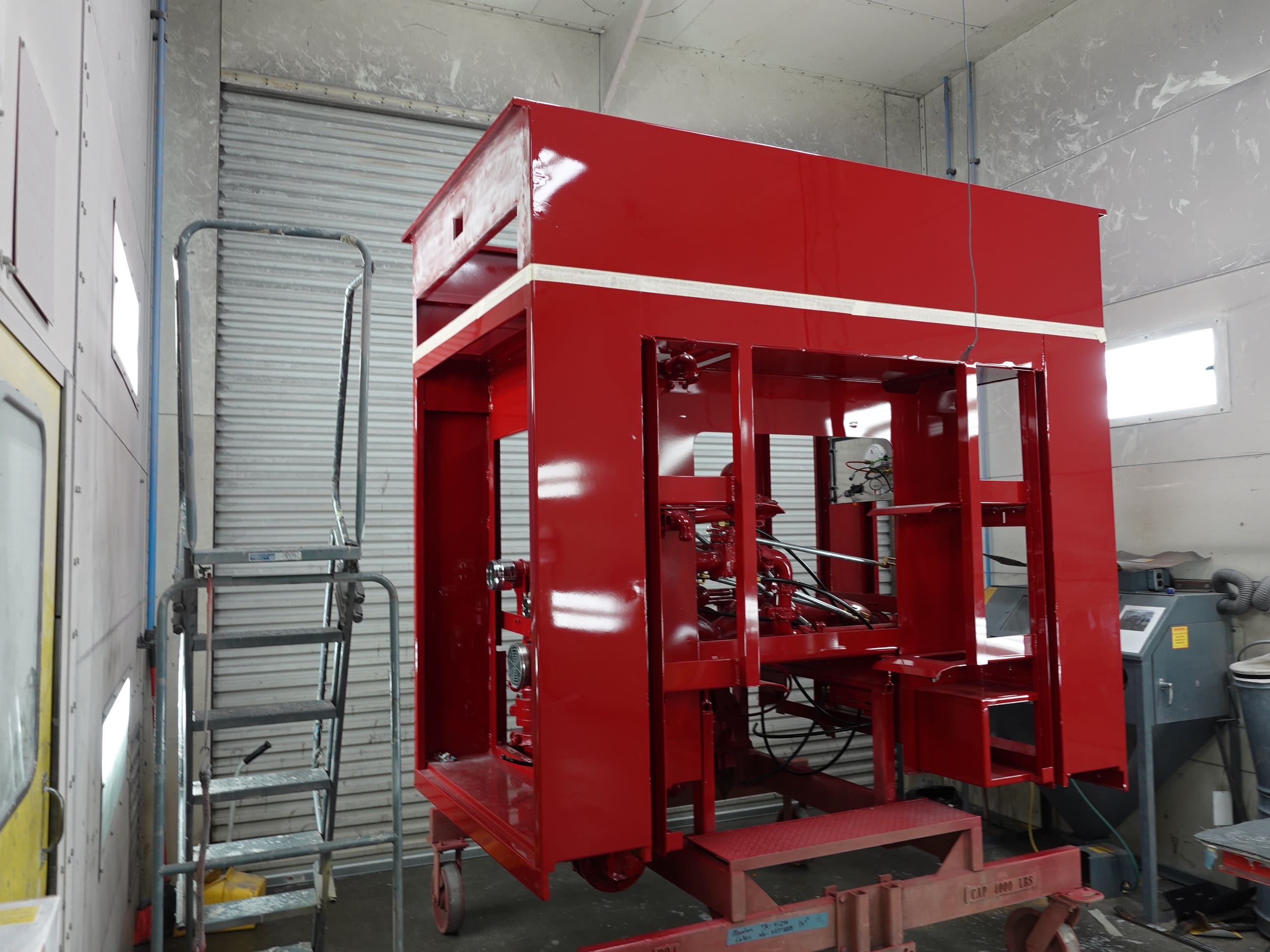

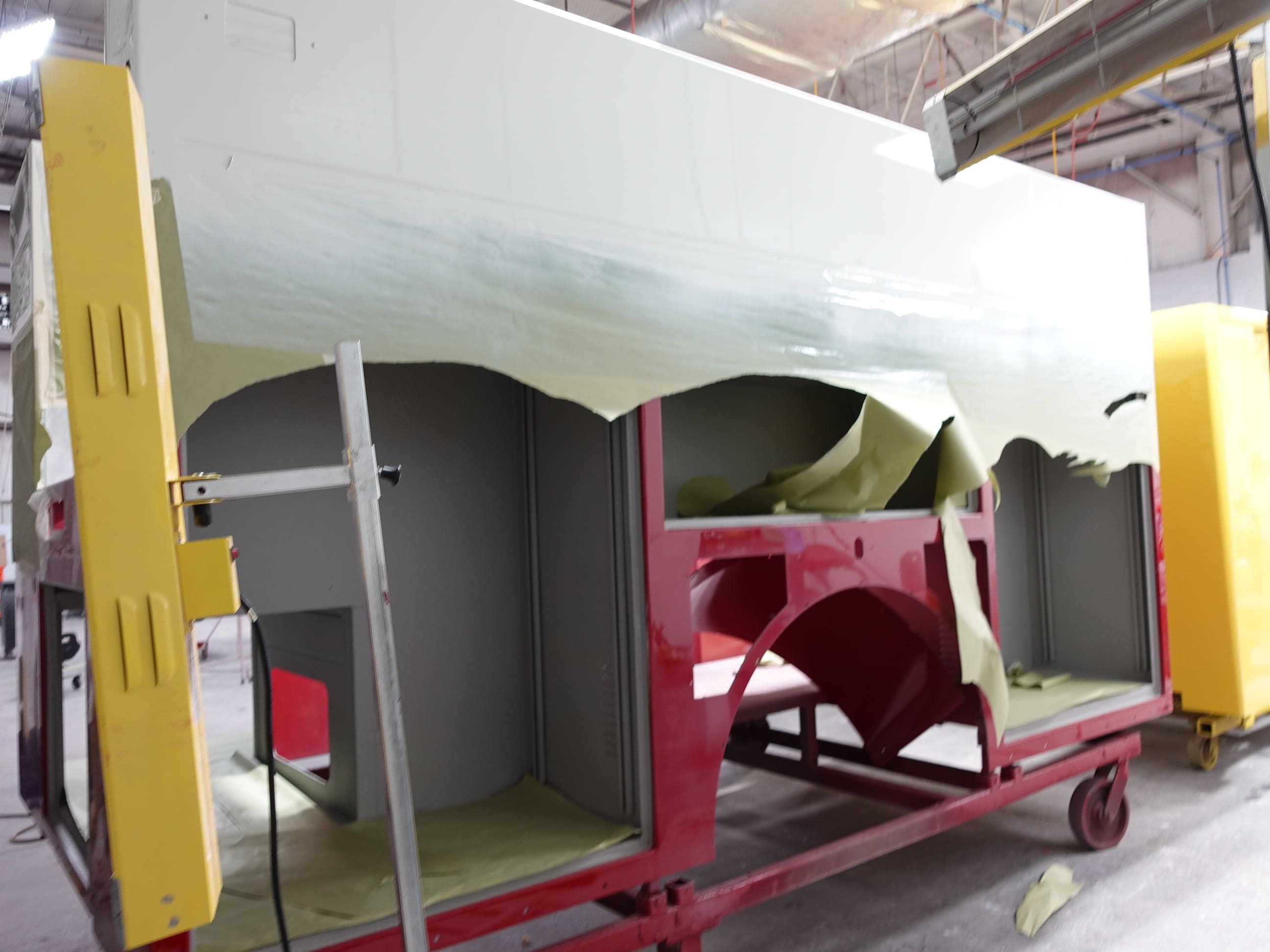

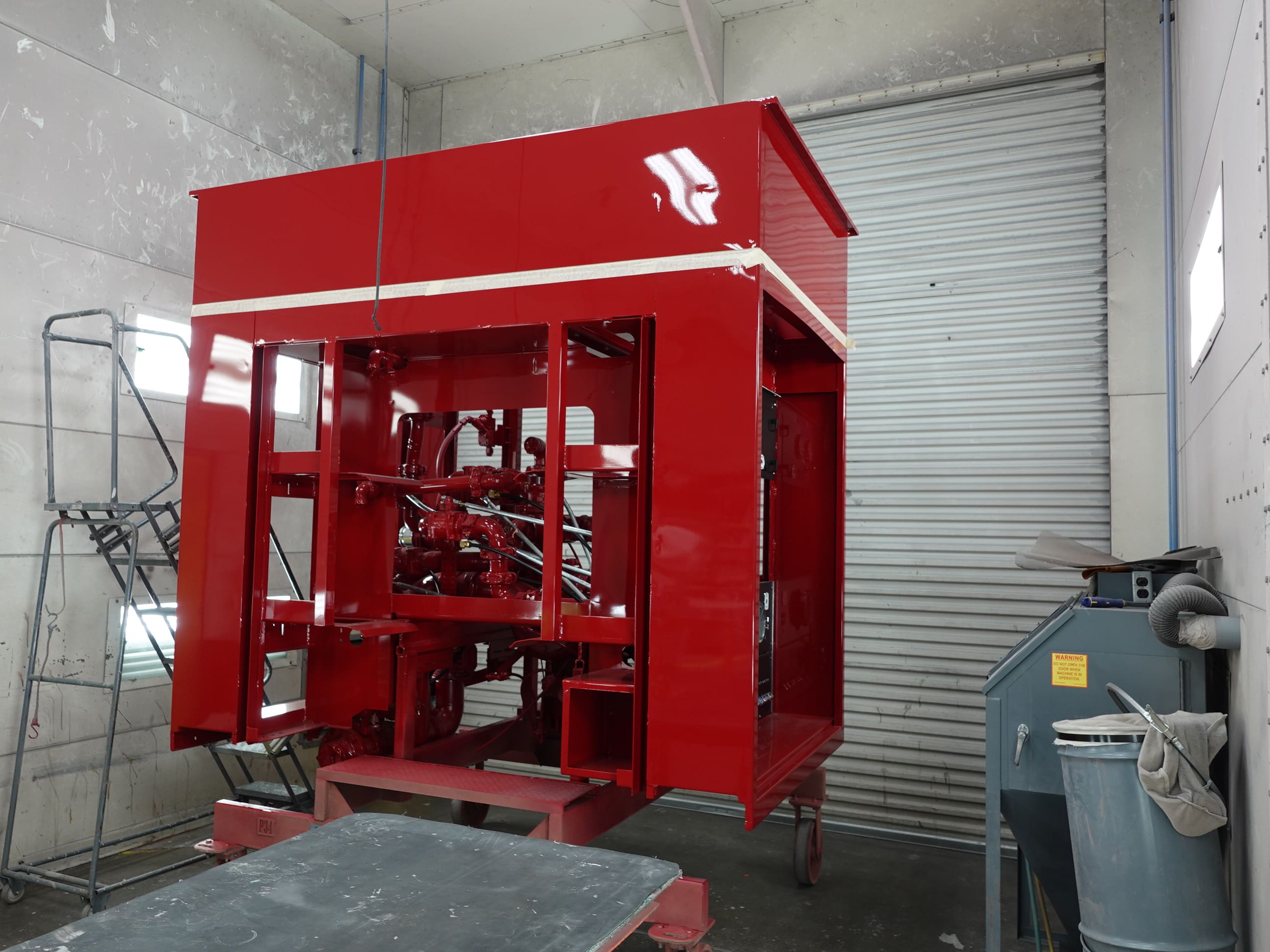

In this report, the cab remained staged, the frame was staged (no photos), the pump house continued through paint, and the body completed the paint process.

03-20-26

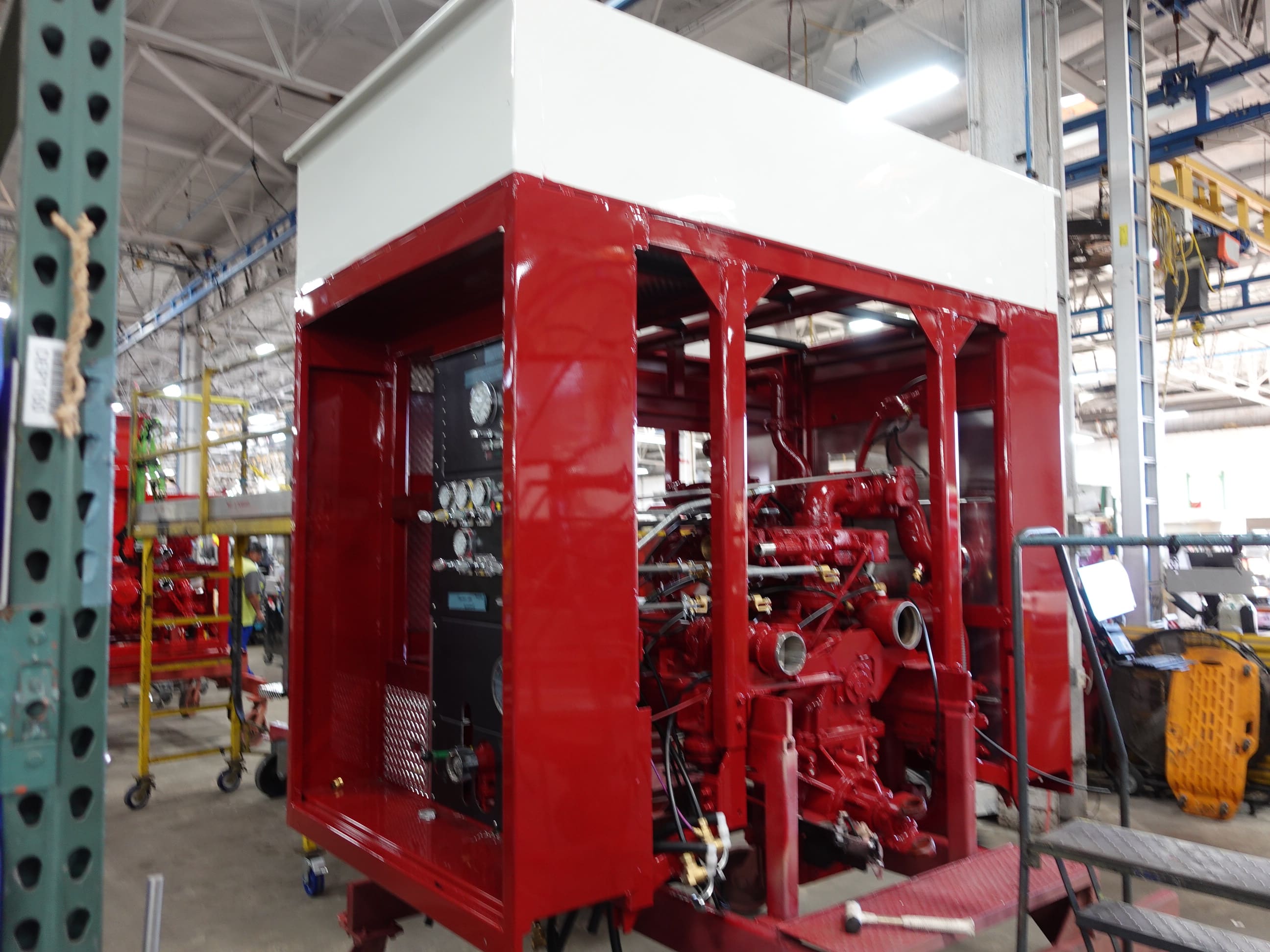

In this report, the cab was staged, the frame remained staged (no photos), the pump house began the paint process, and the body returned to paint.

03-13-26

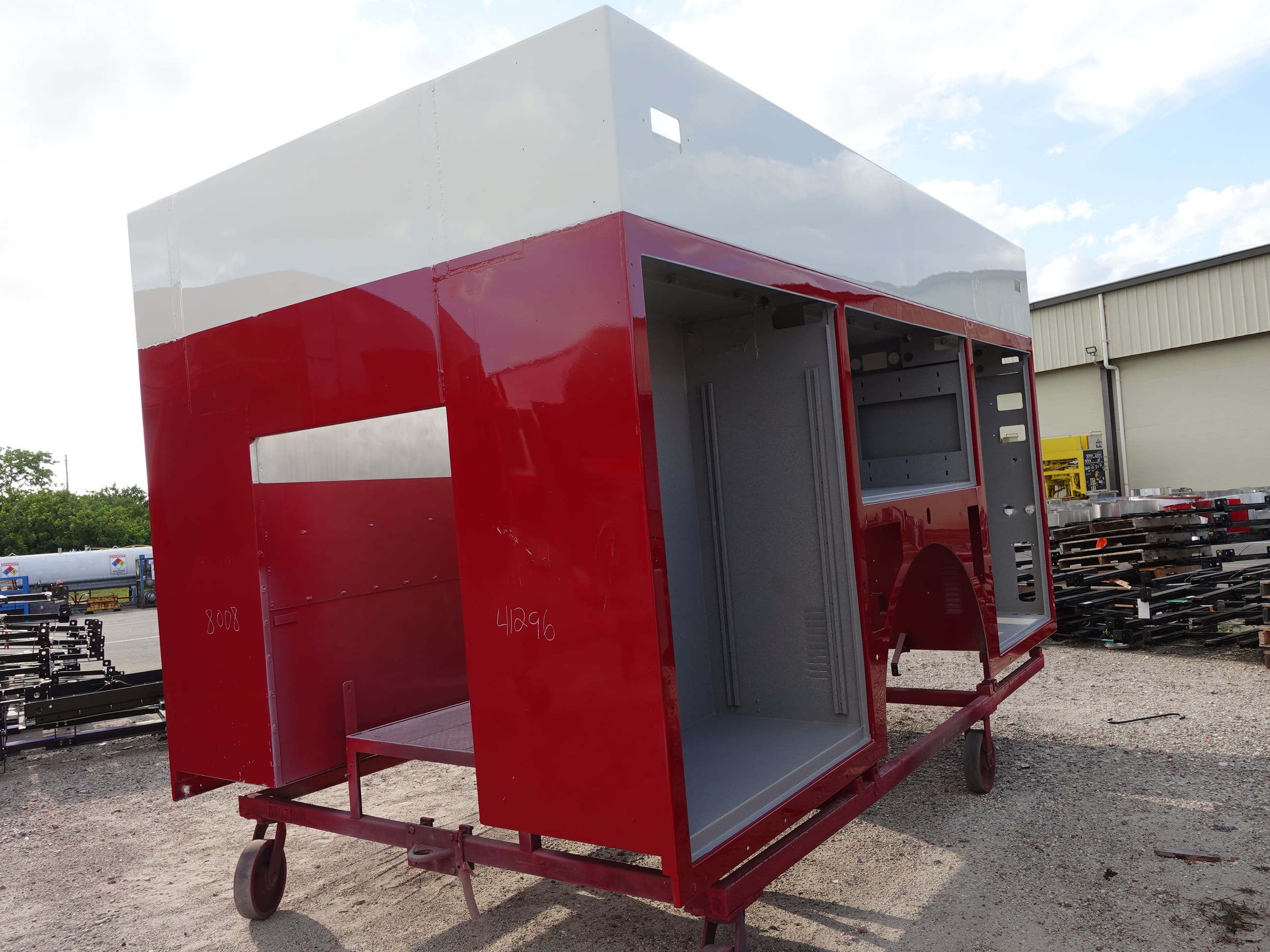

In this report, the cab completed the paint process, the frame was staged (no photos), the pump house remained staged, and the body completed the paint process.

03-06-26

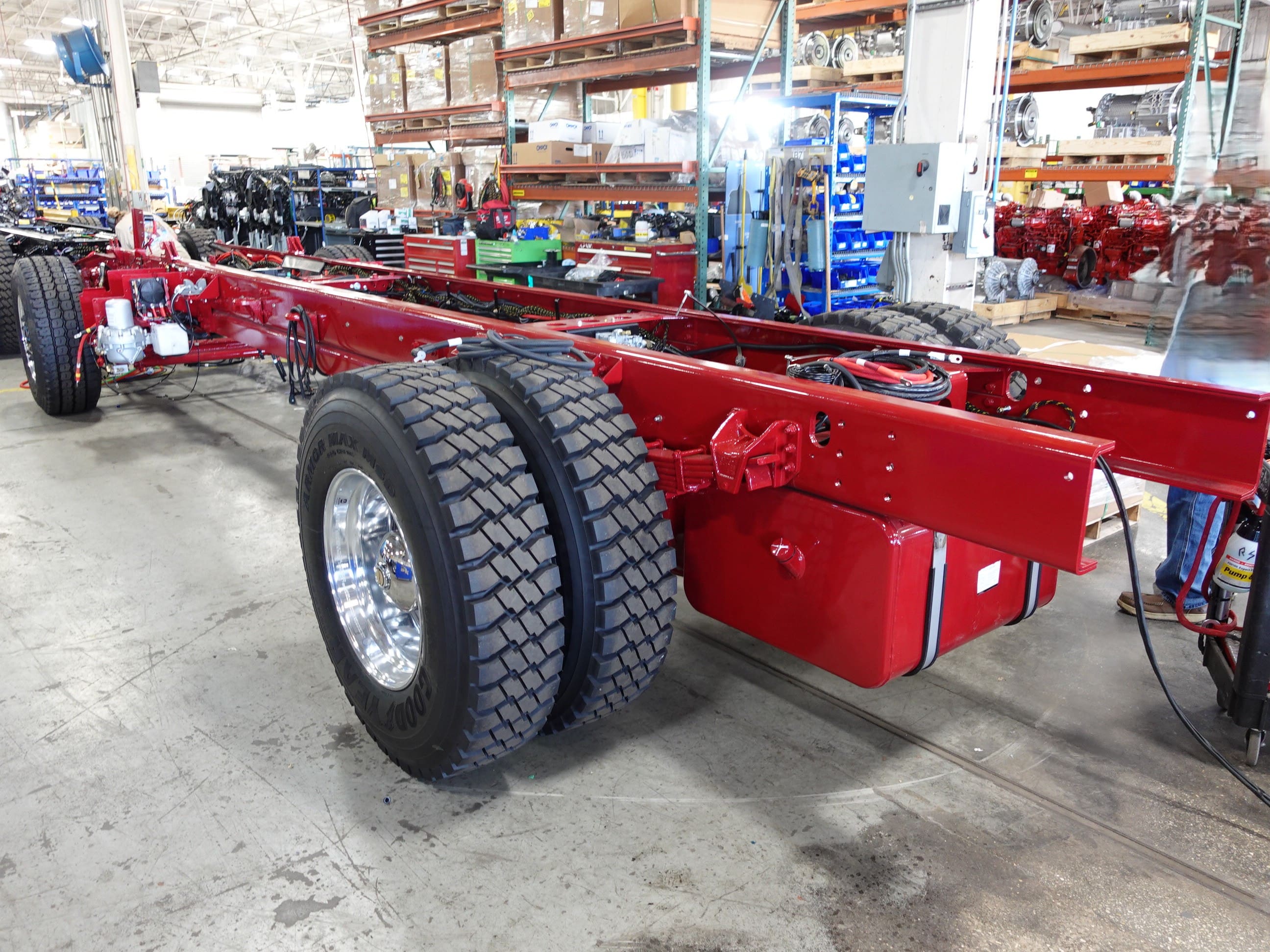

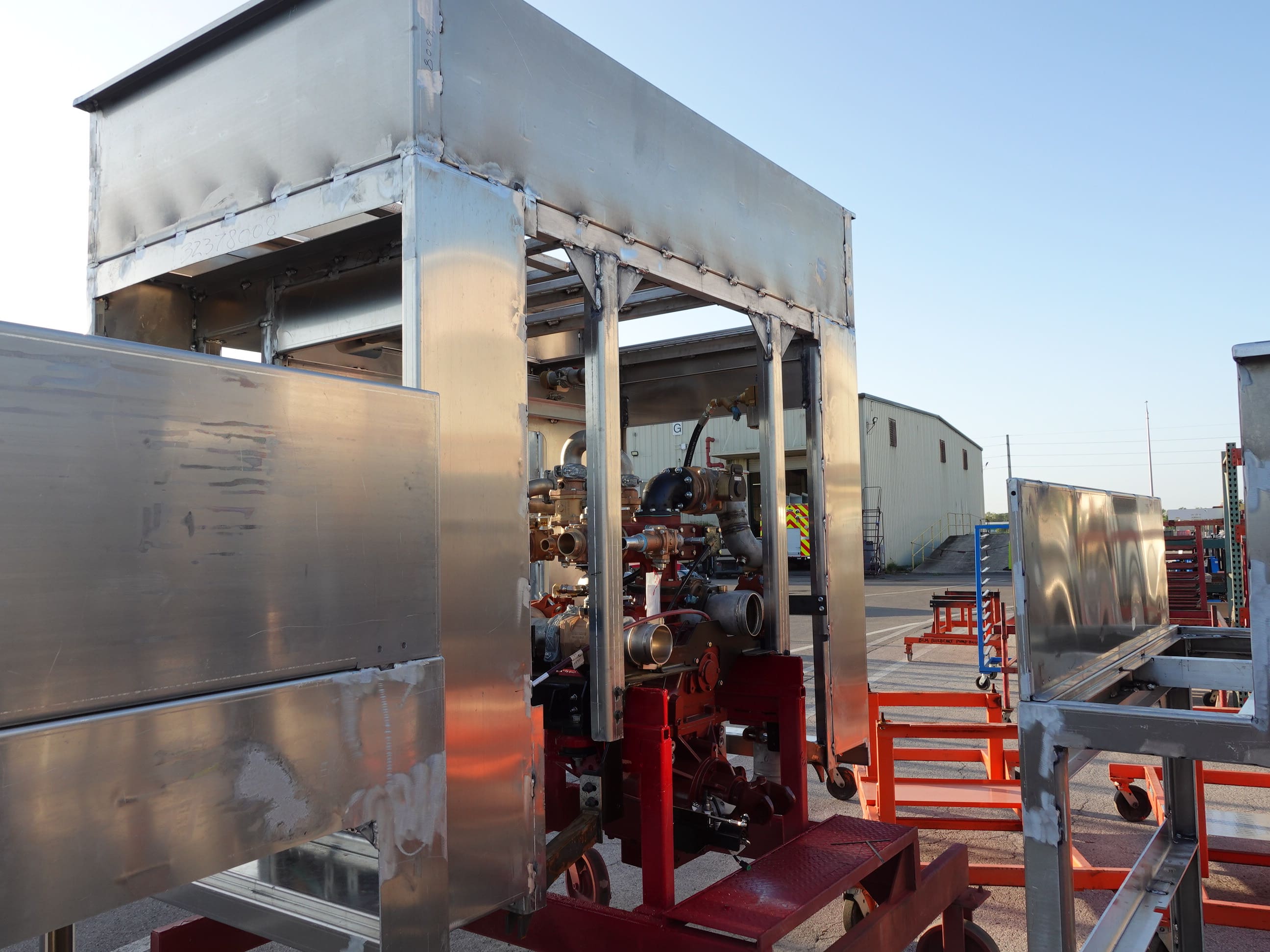

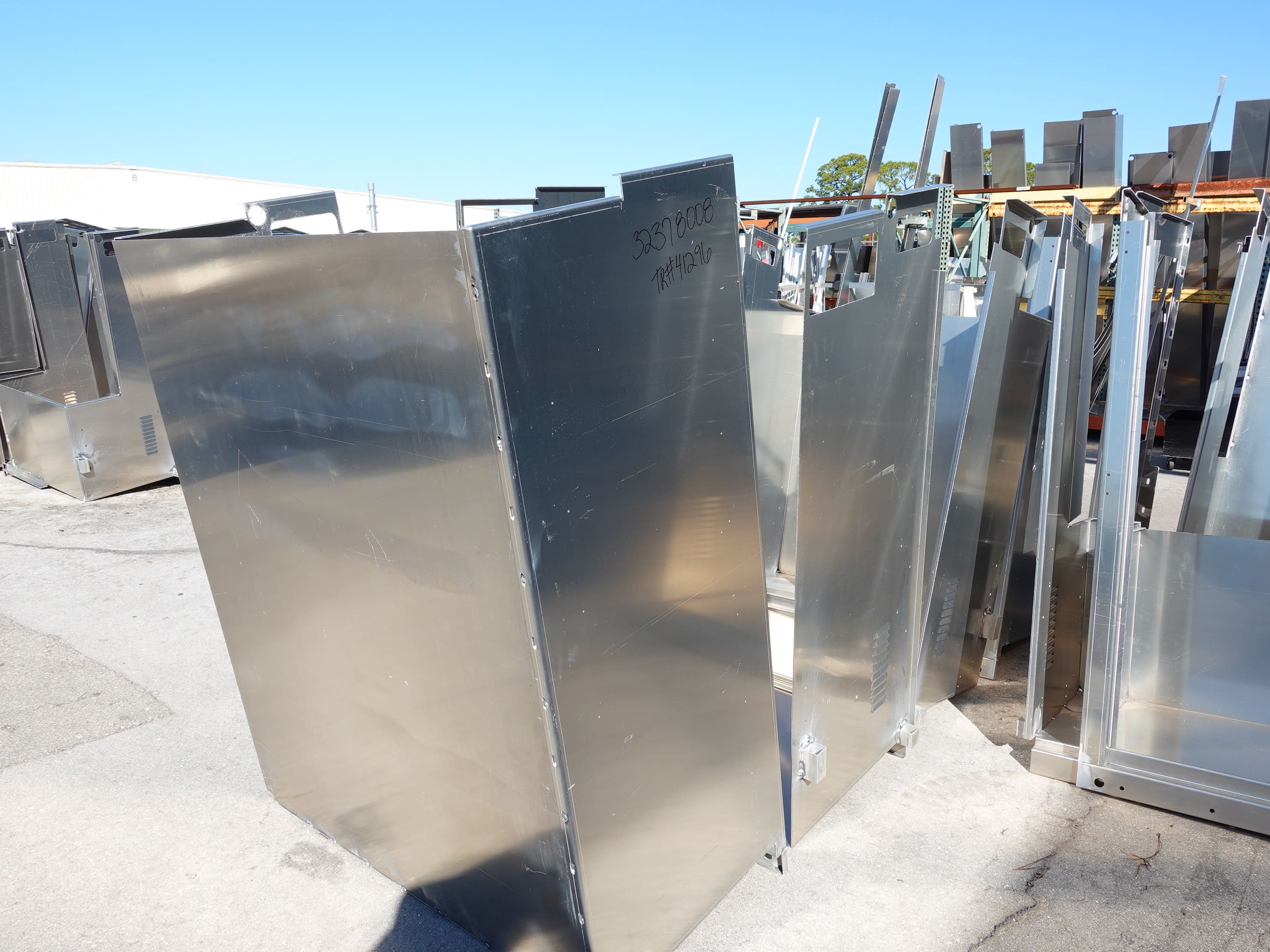

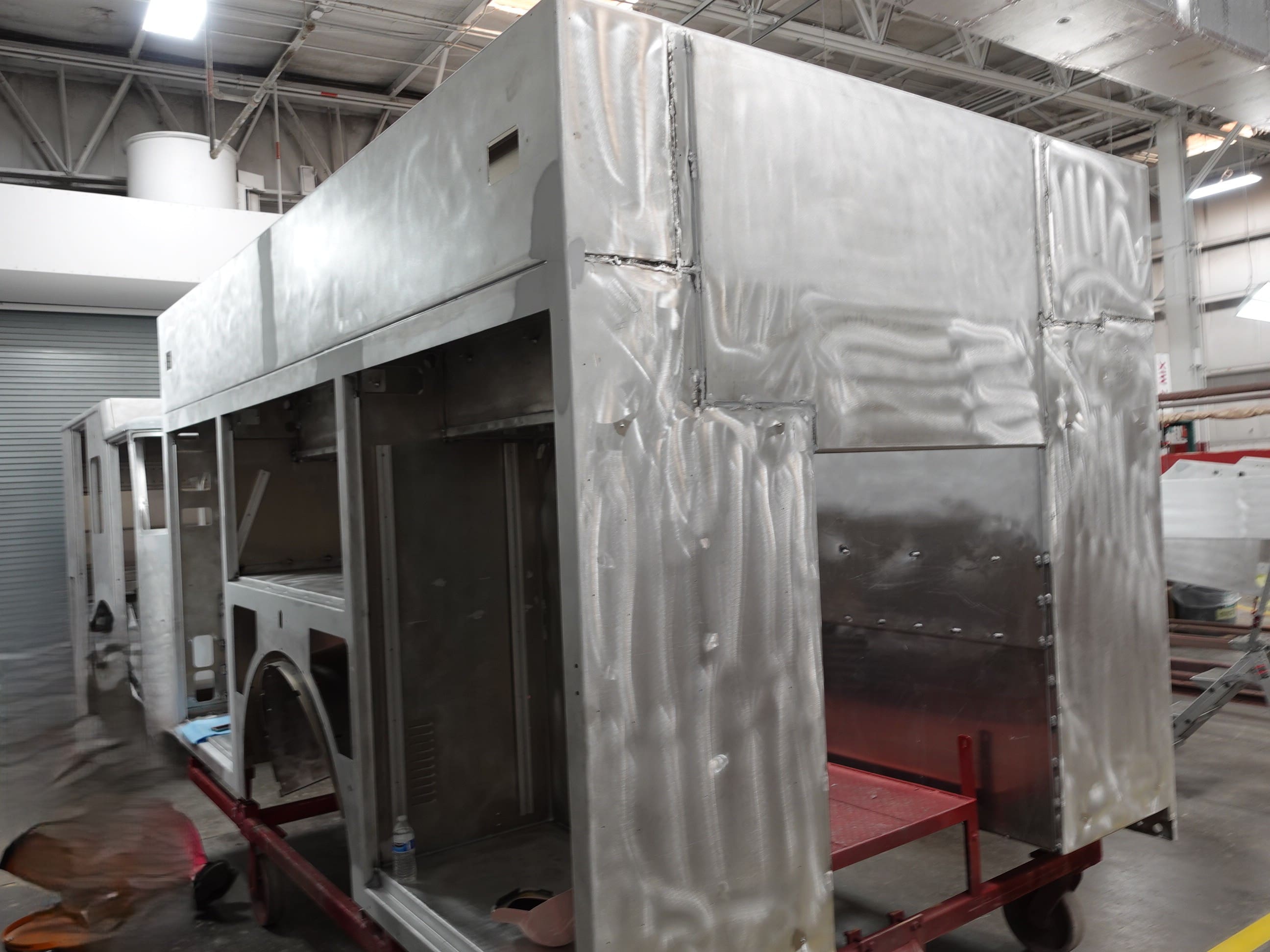

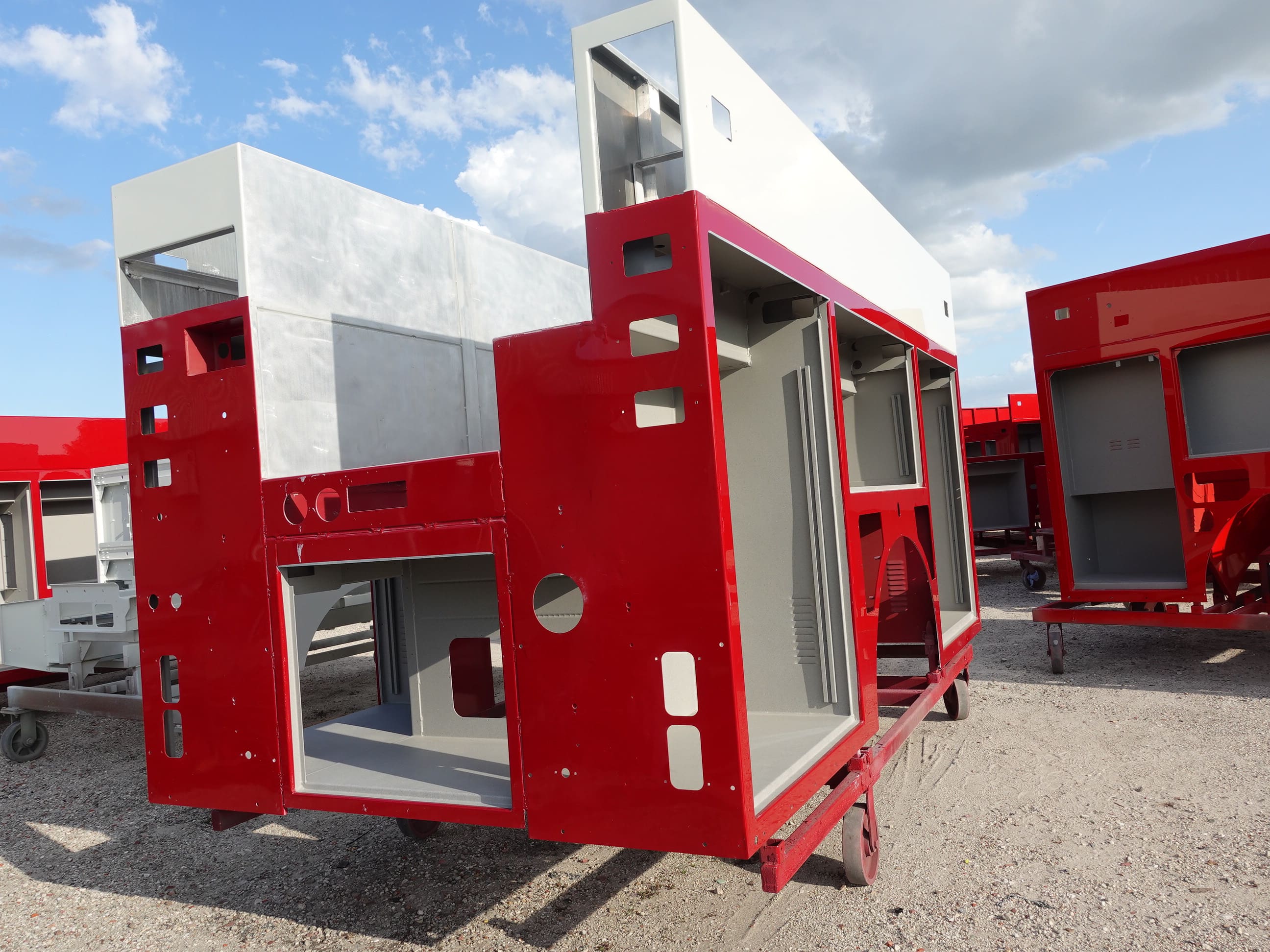

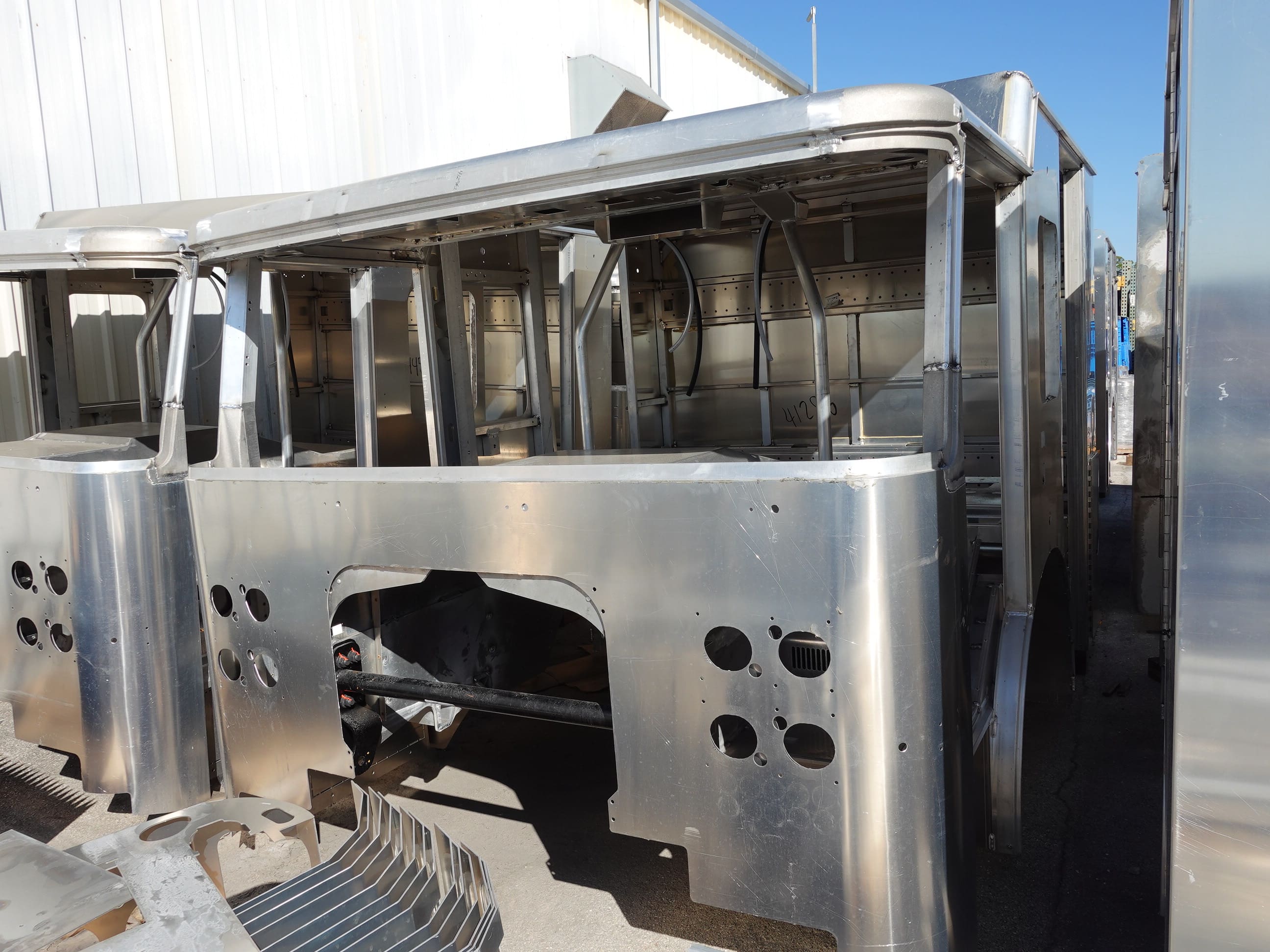

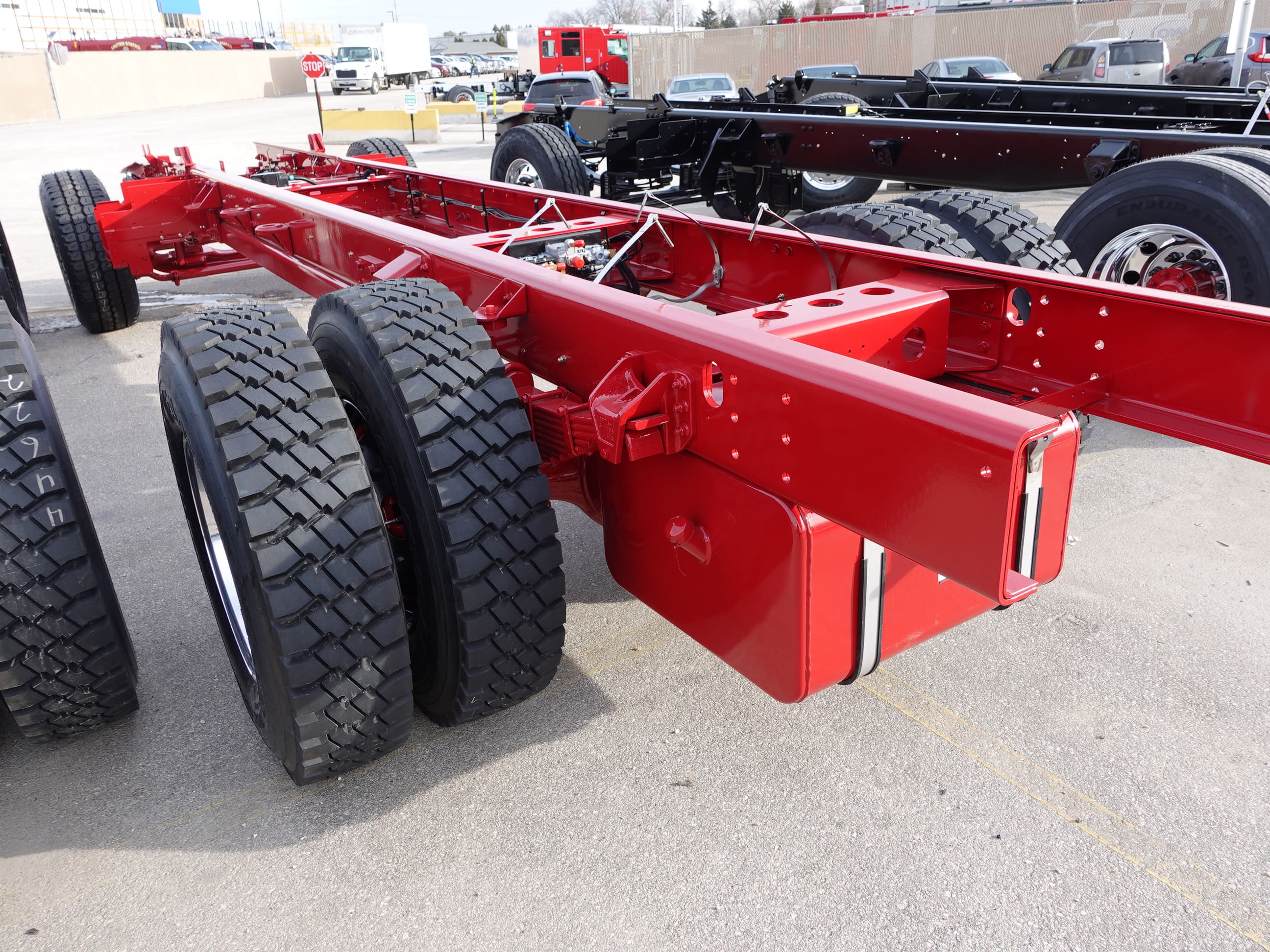

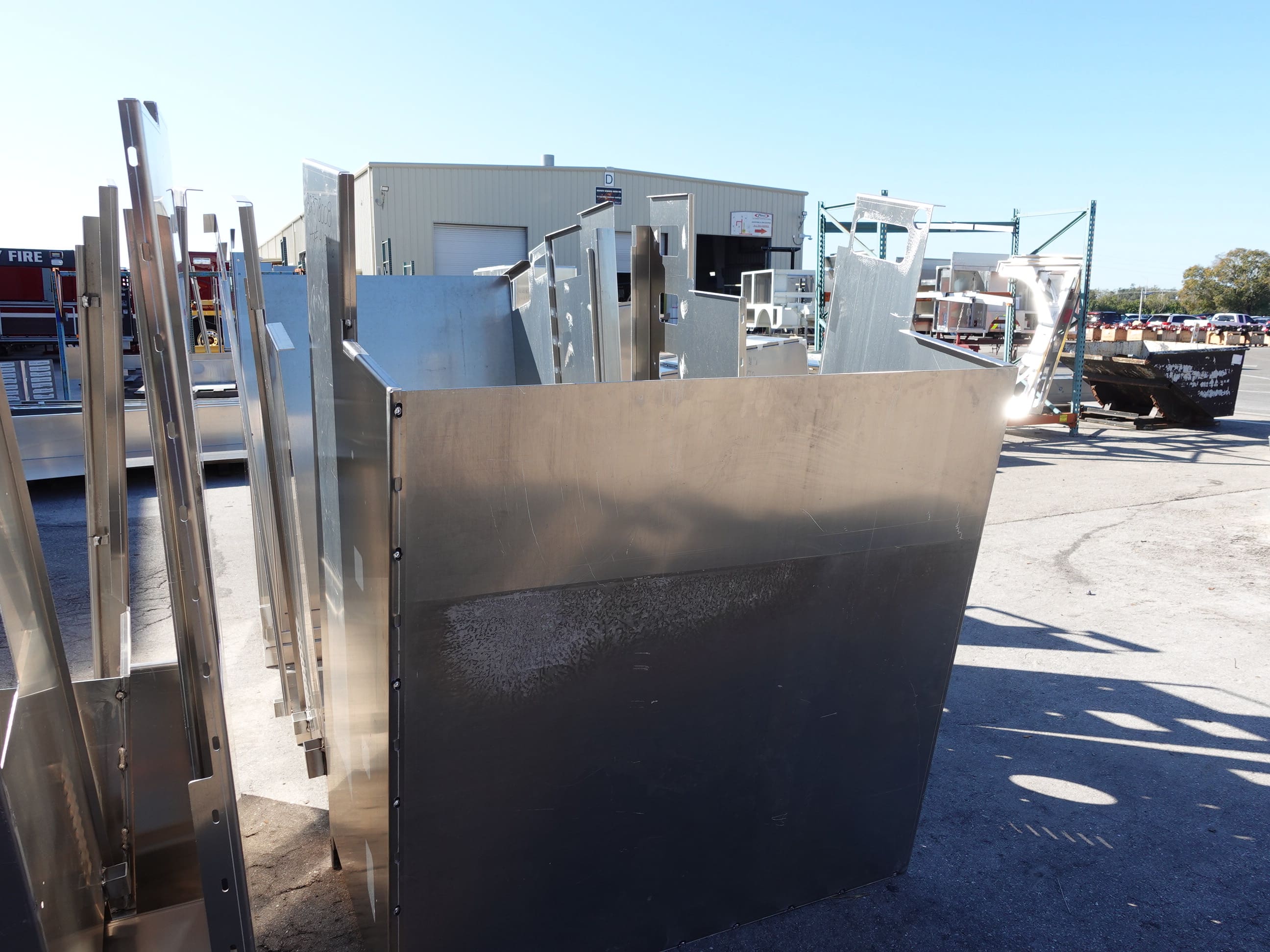

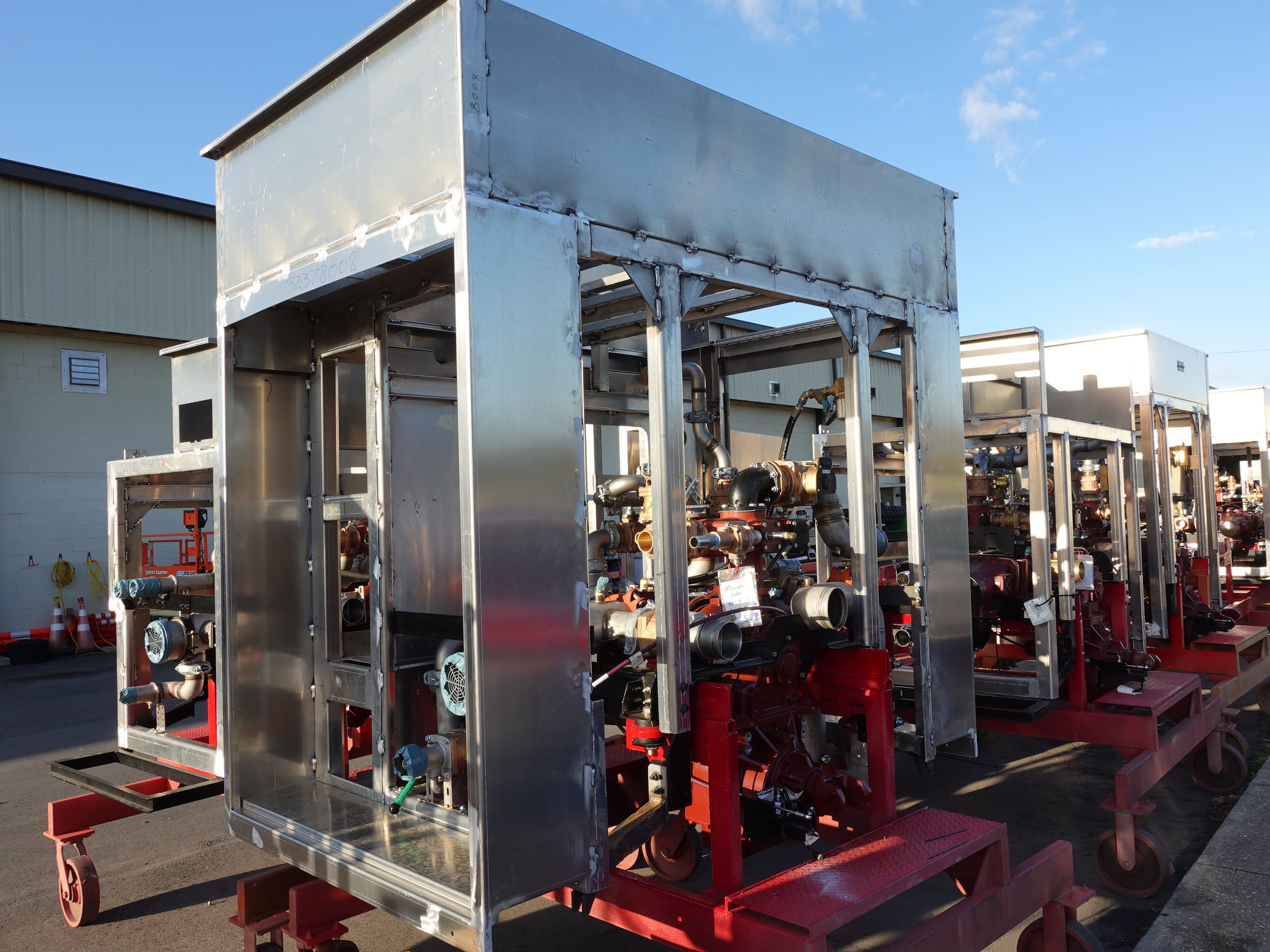

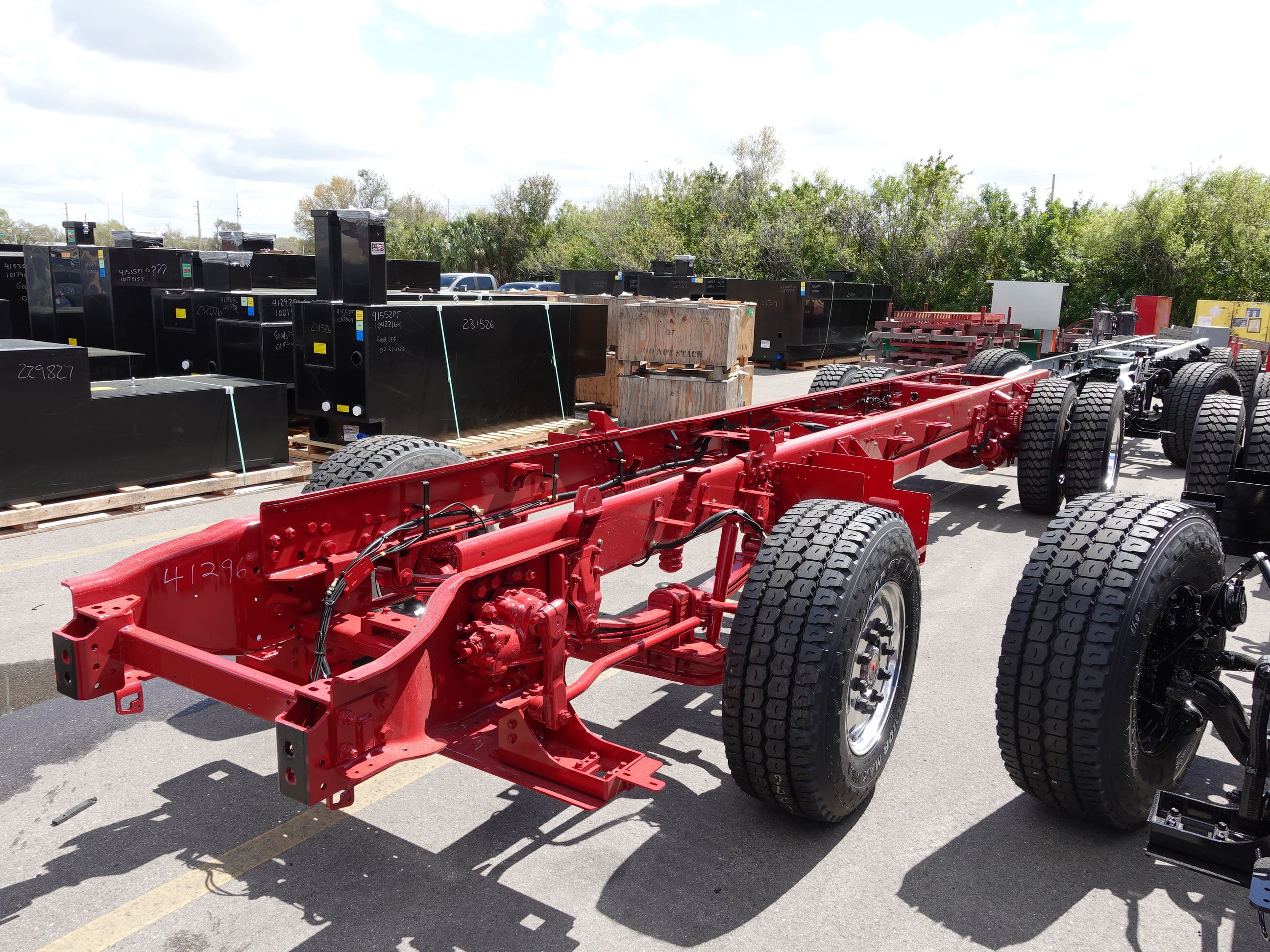

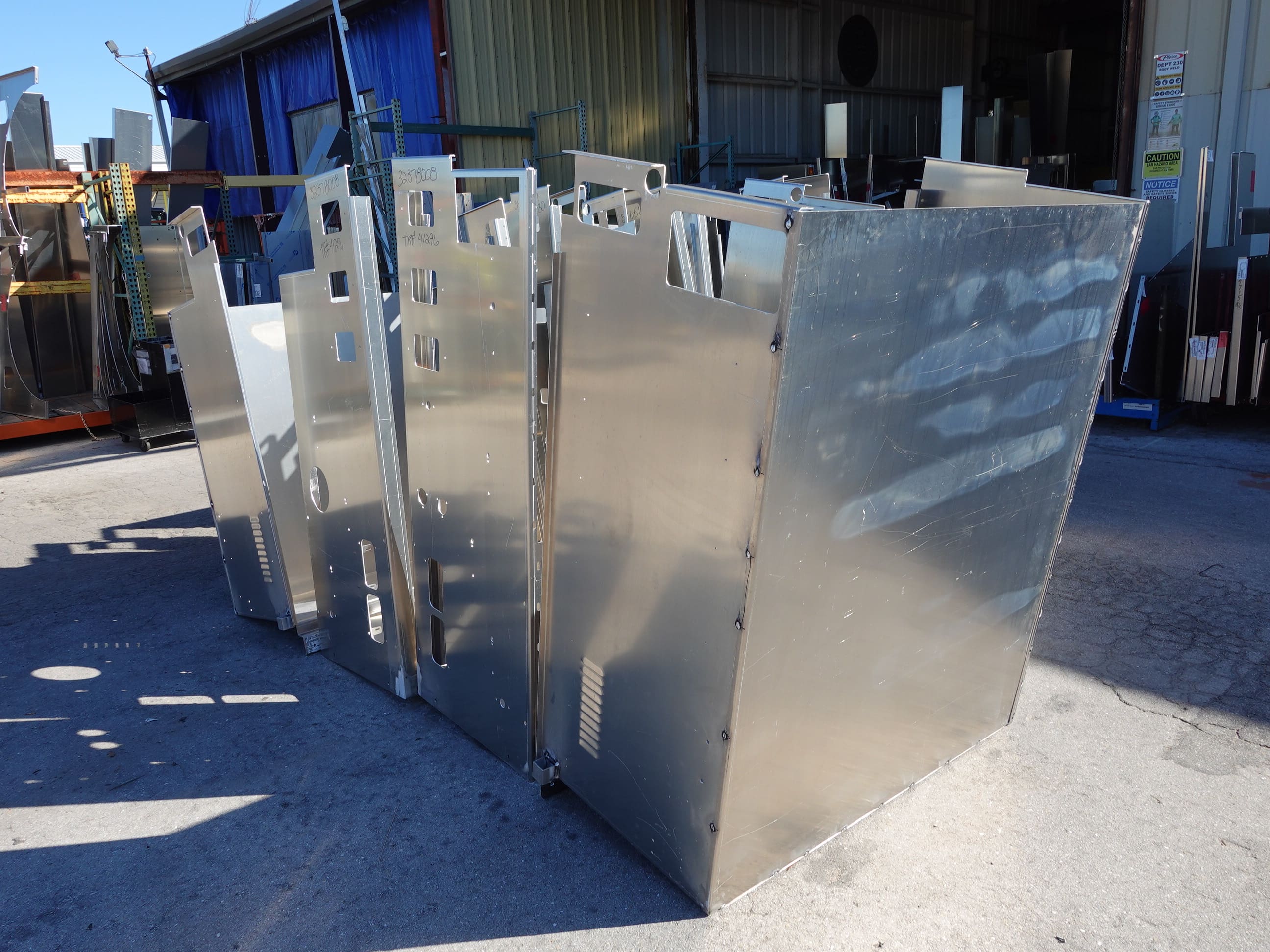

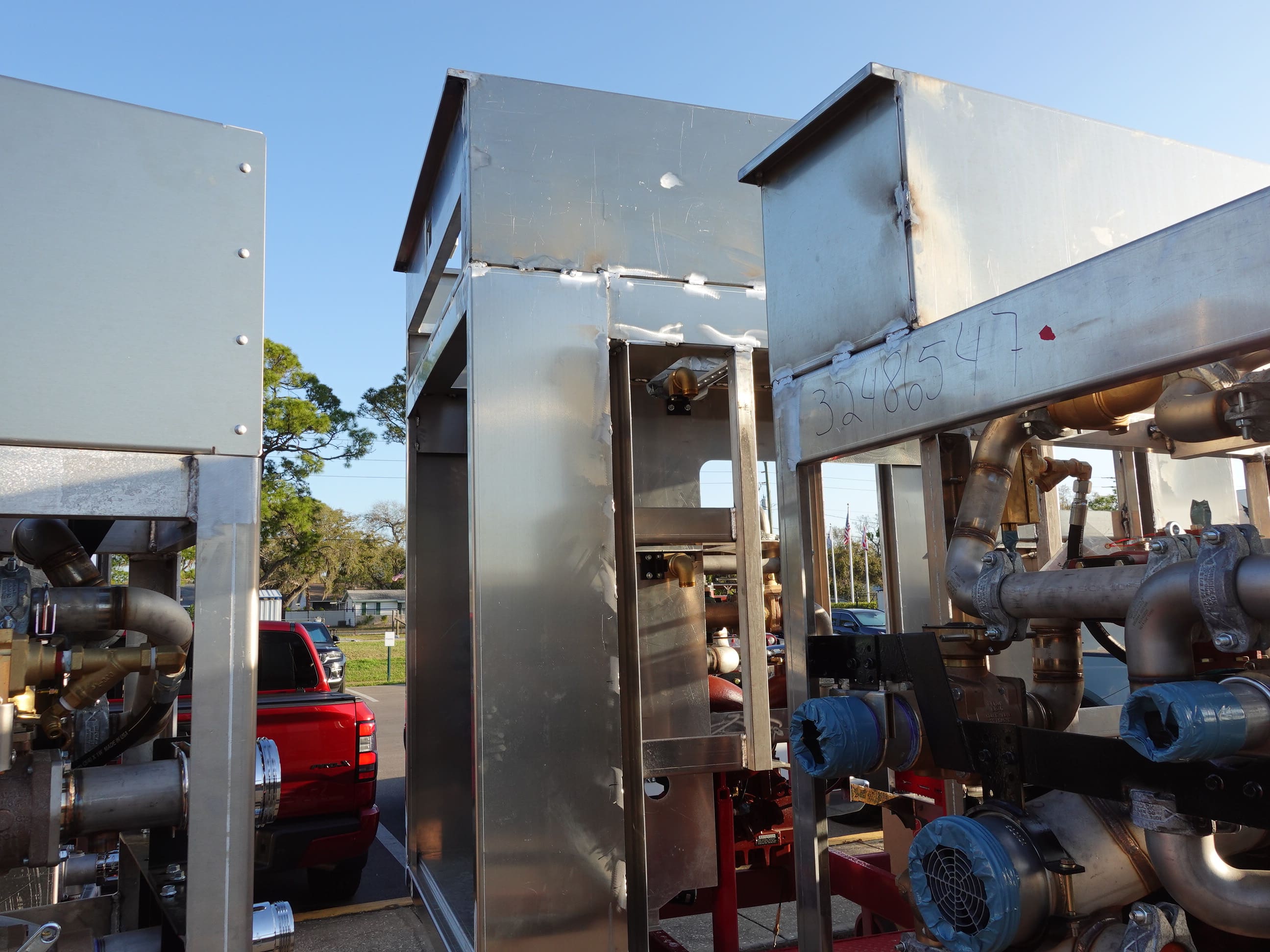

In this report, the cab began the paint process with metal finishing, the frame arrived in Bradenton, the pump house continued initial assembly, and the body completed fabrication and began in paint.

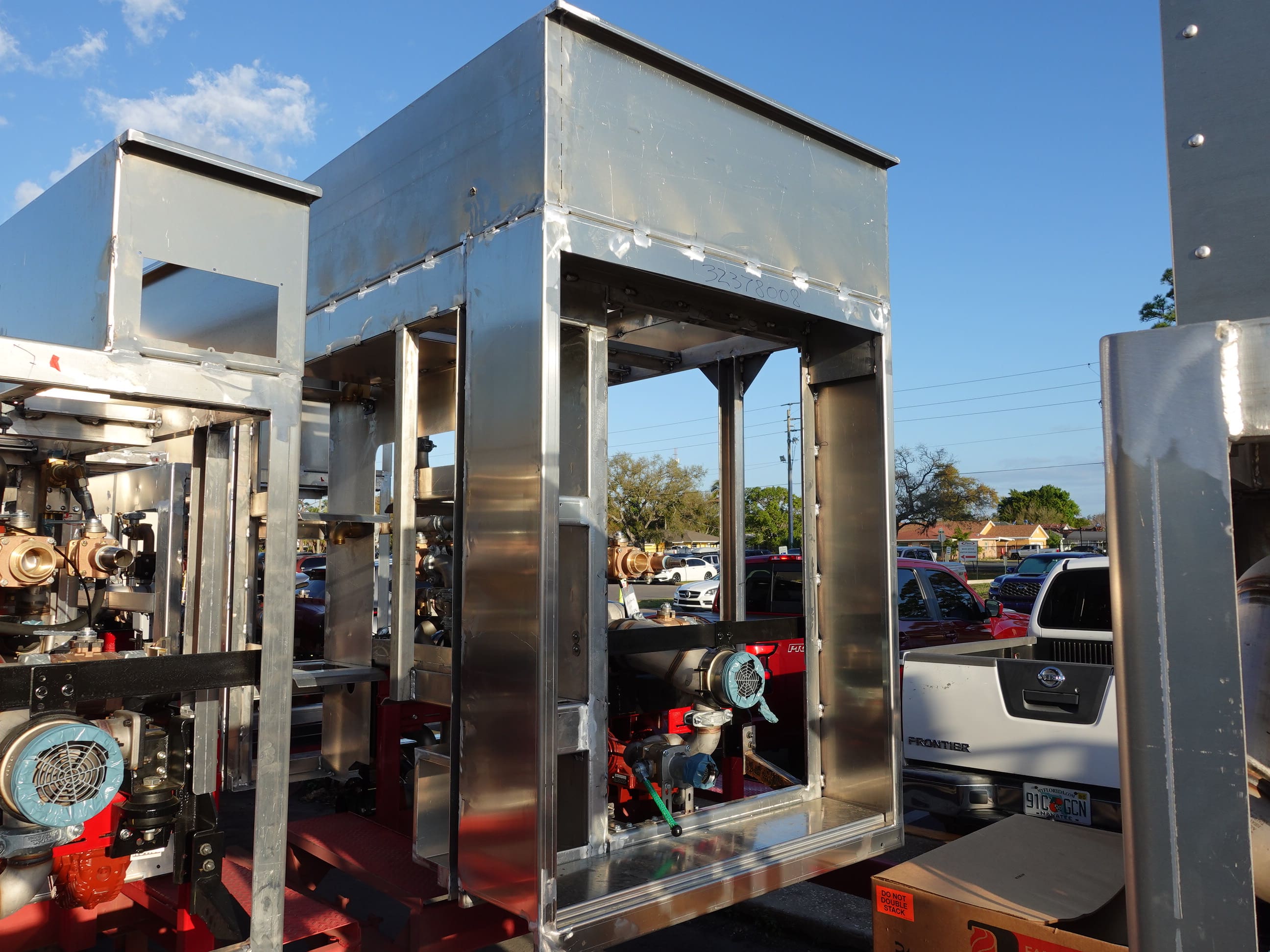

02-27-26

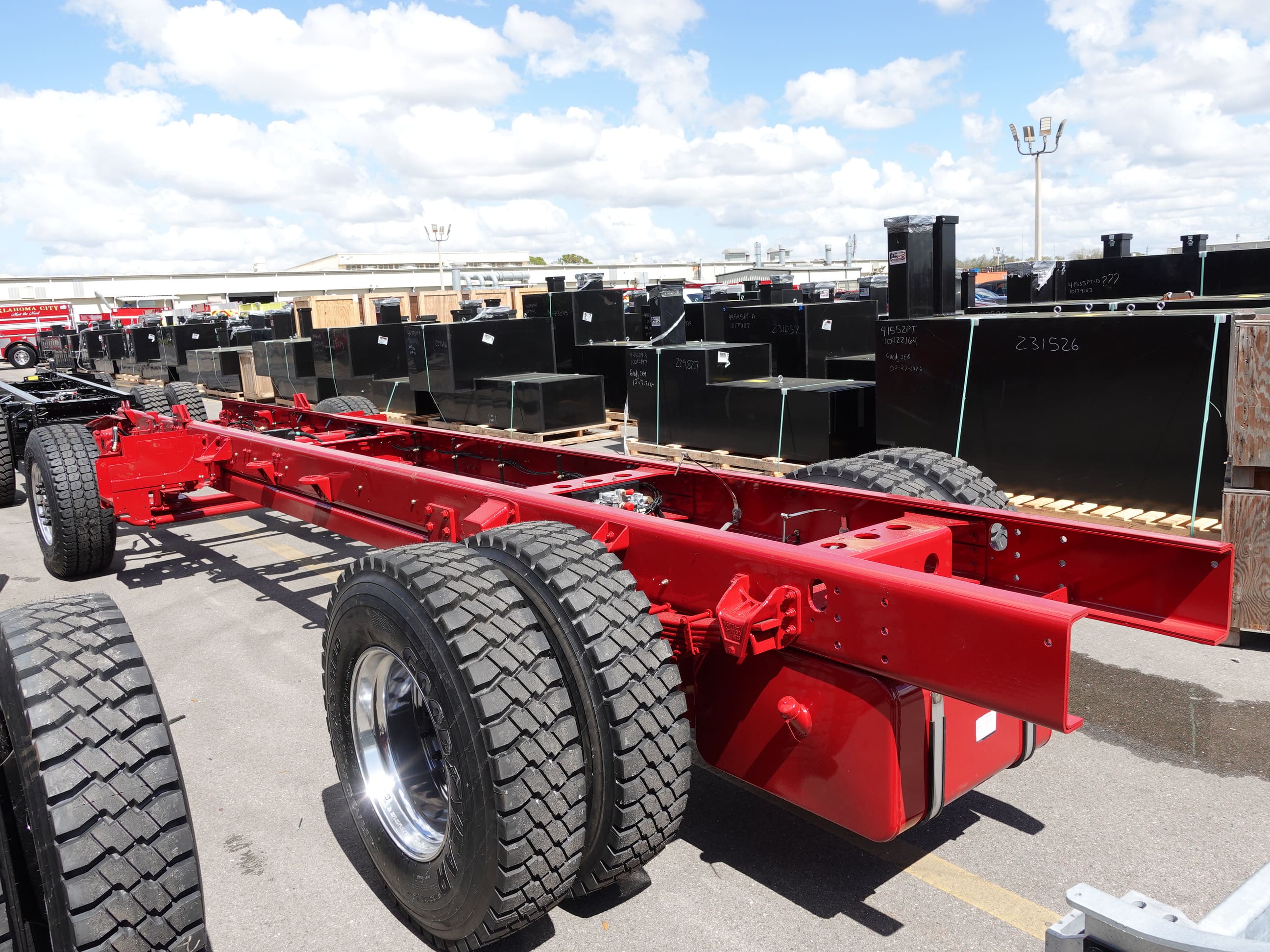

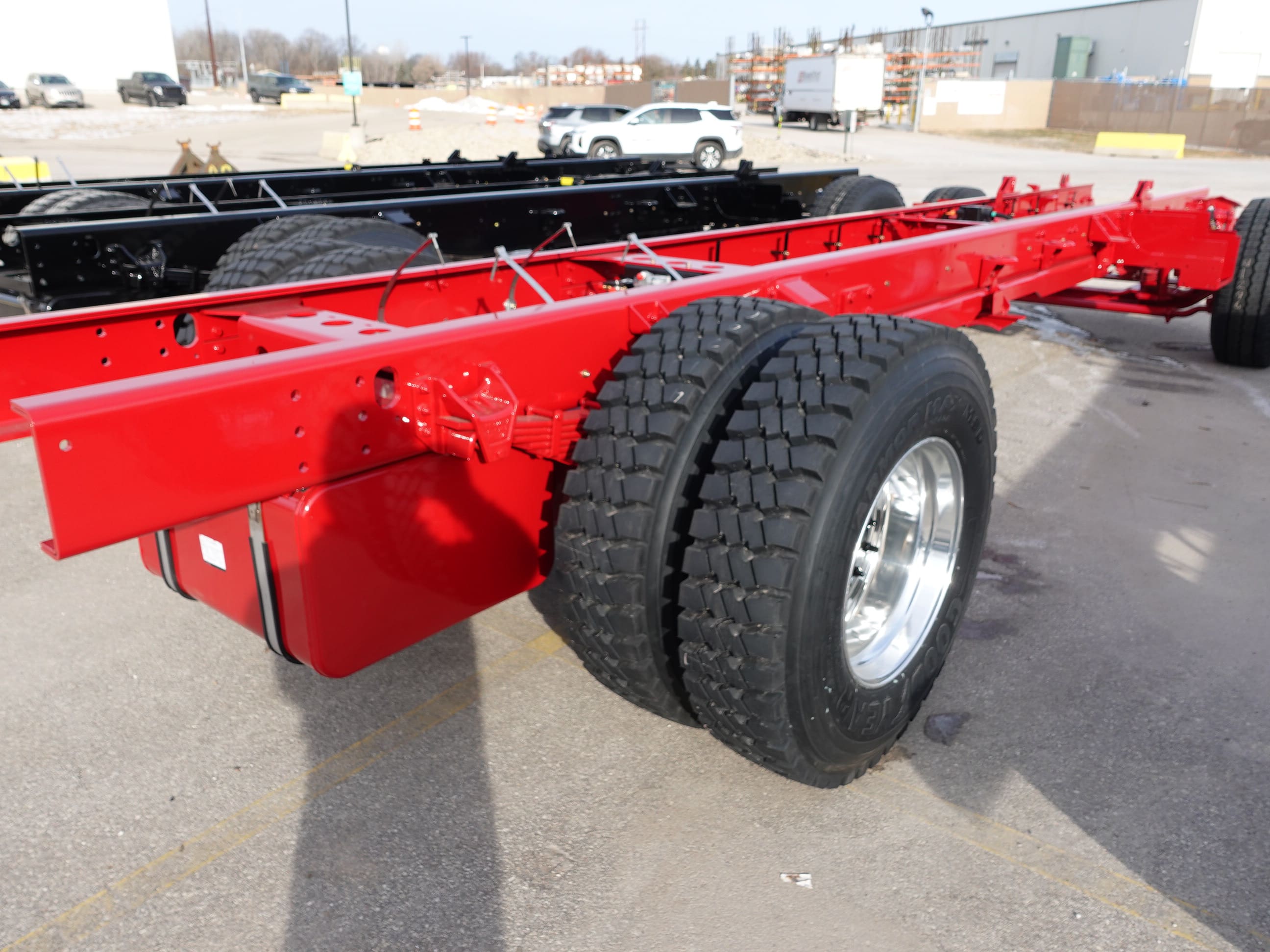

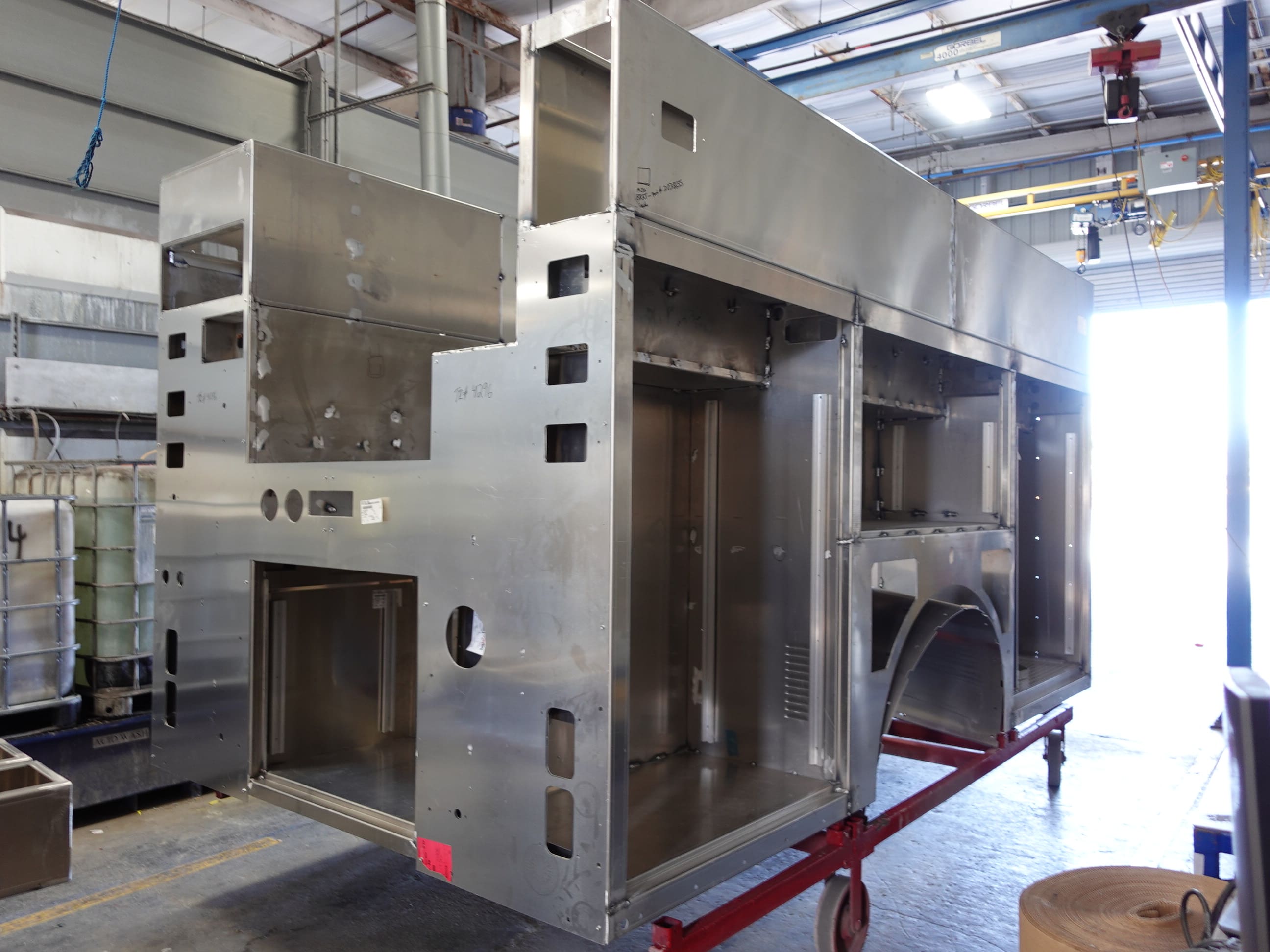

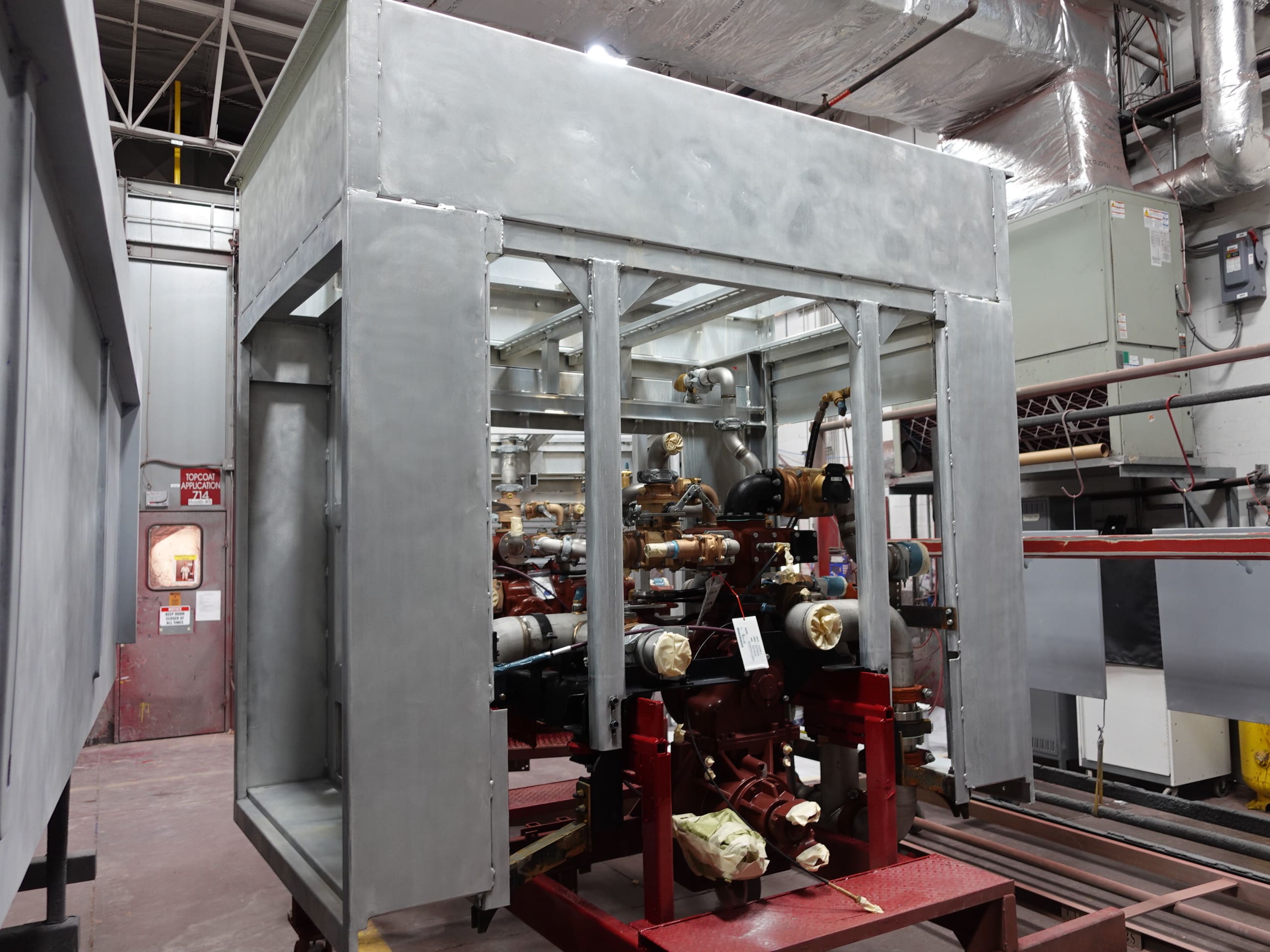

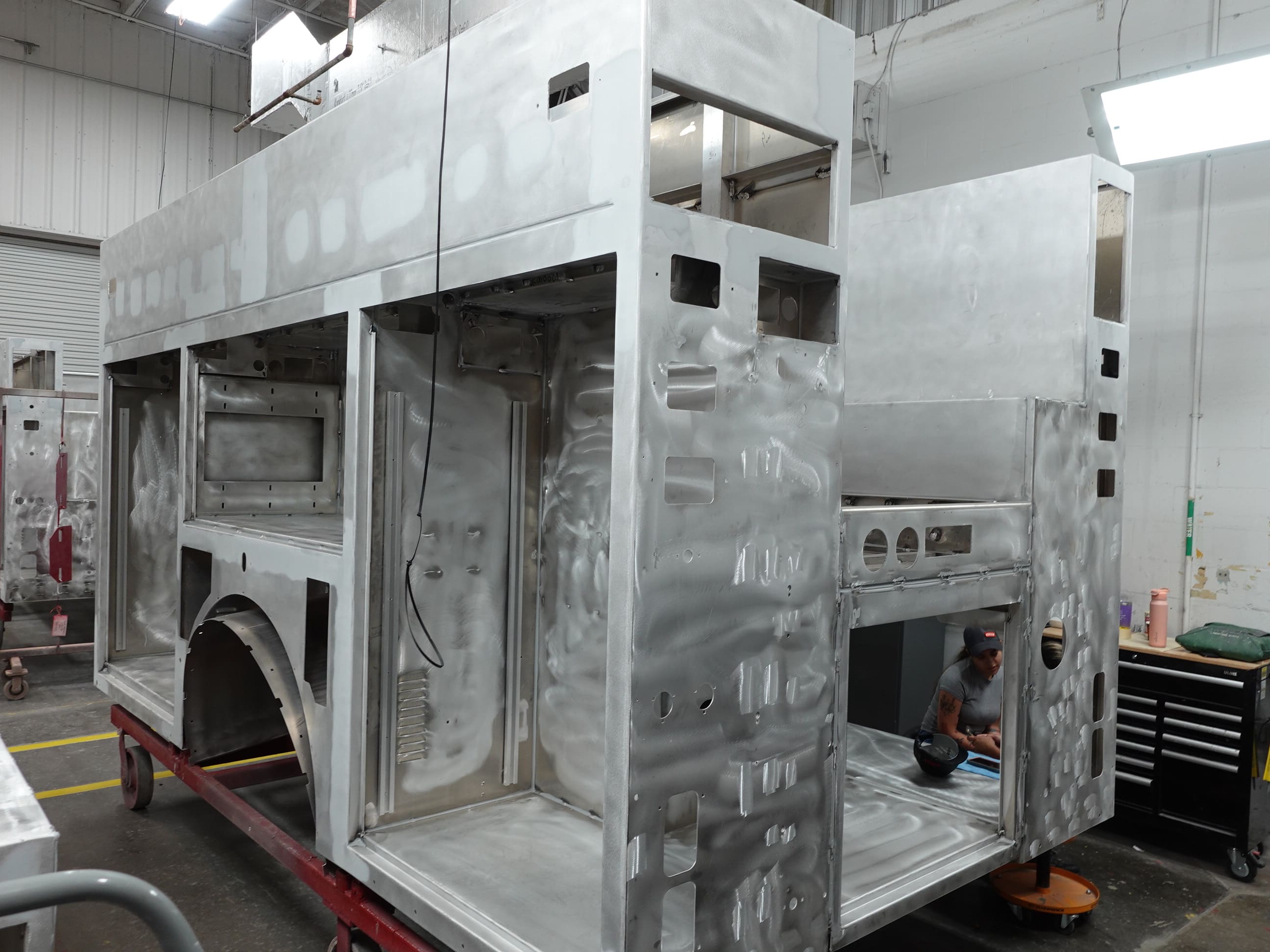

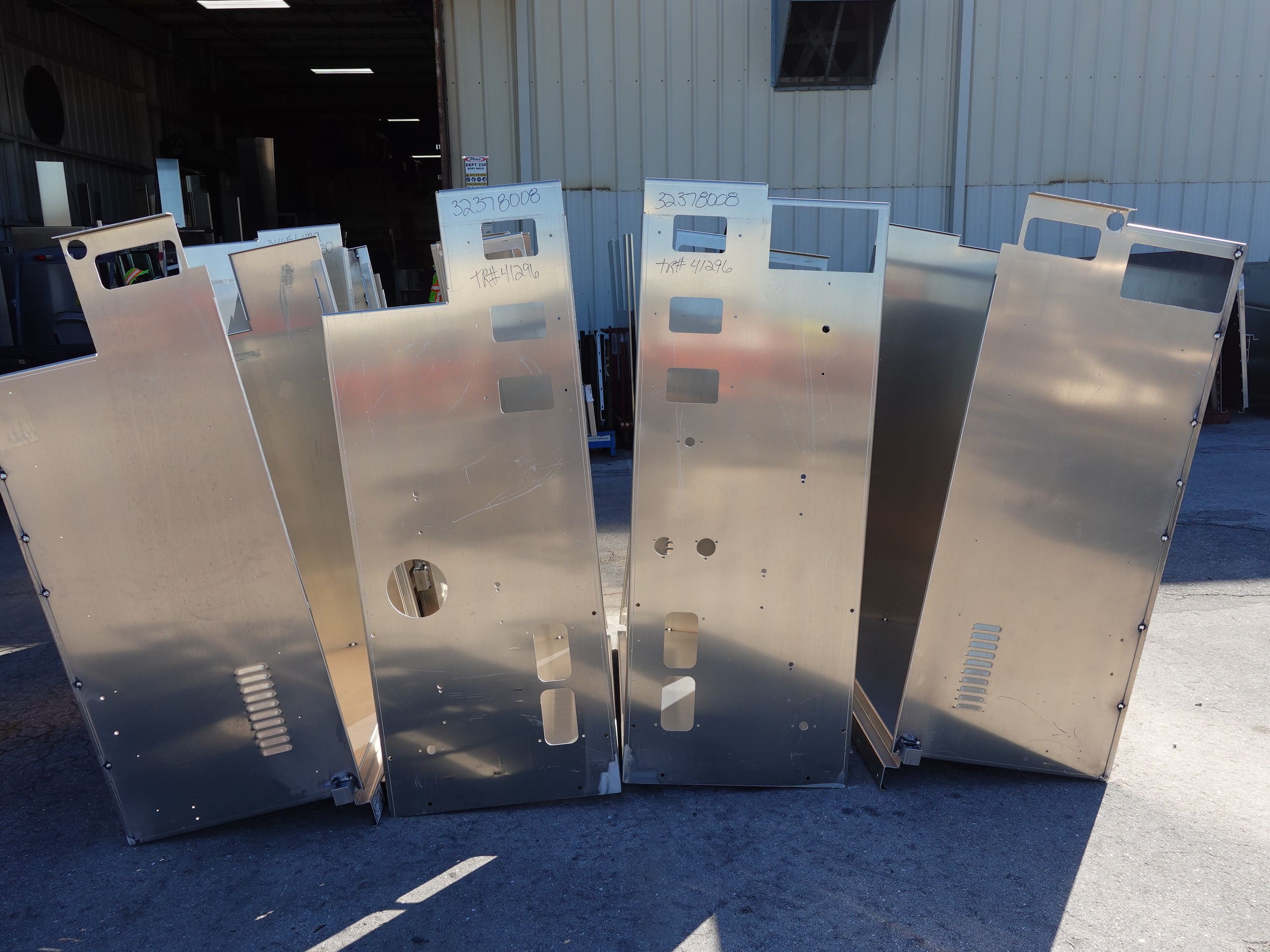

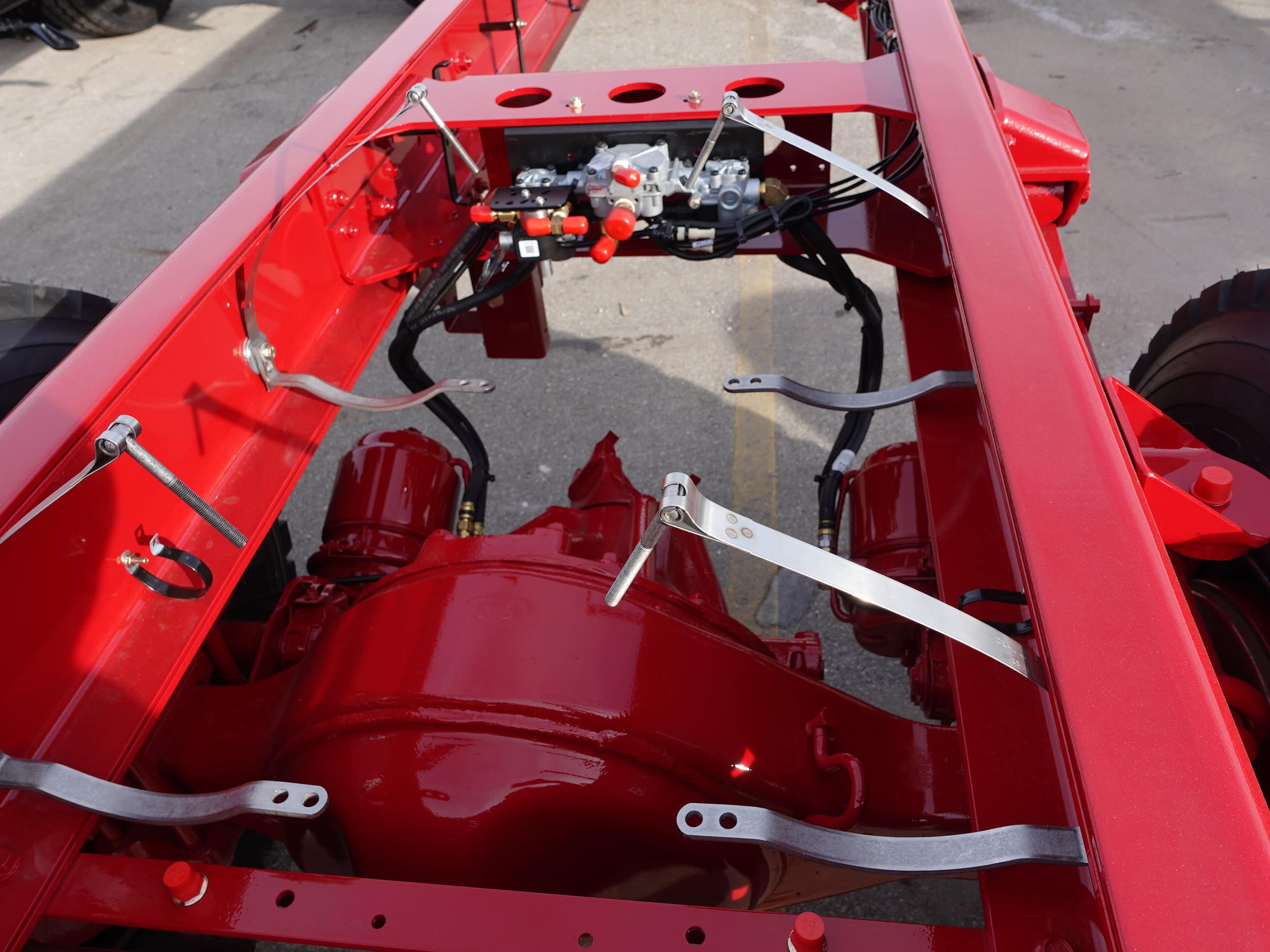

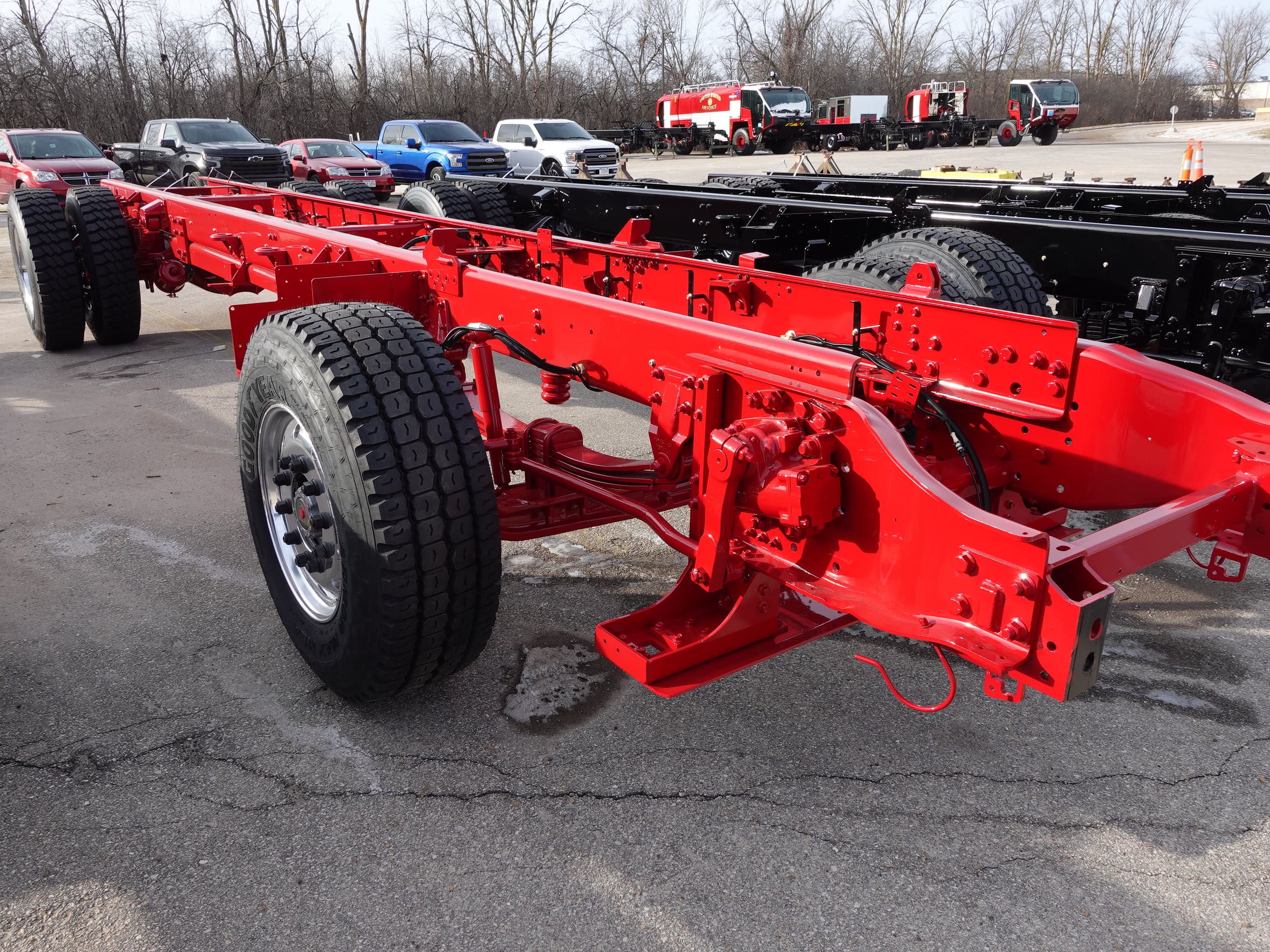

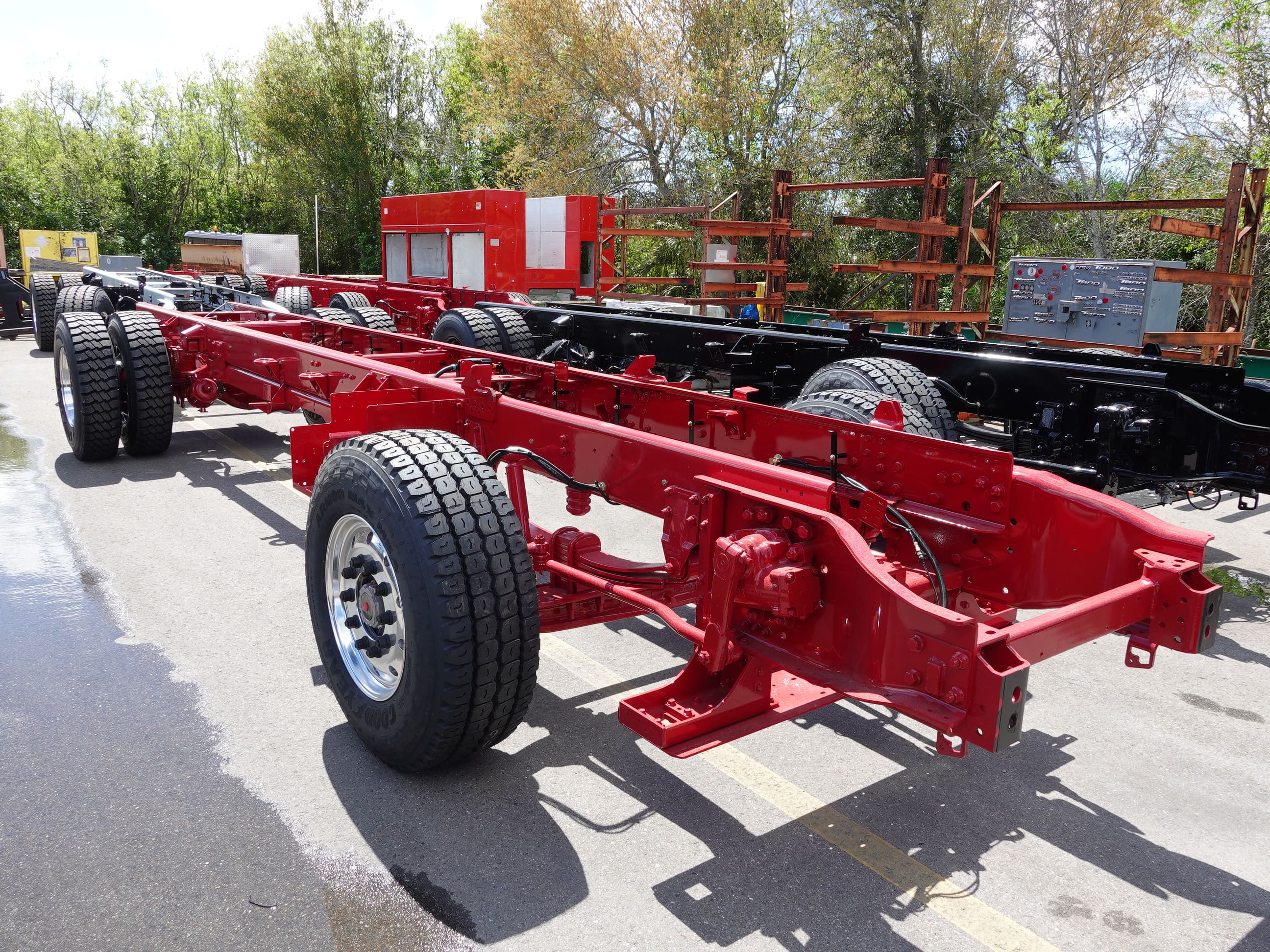

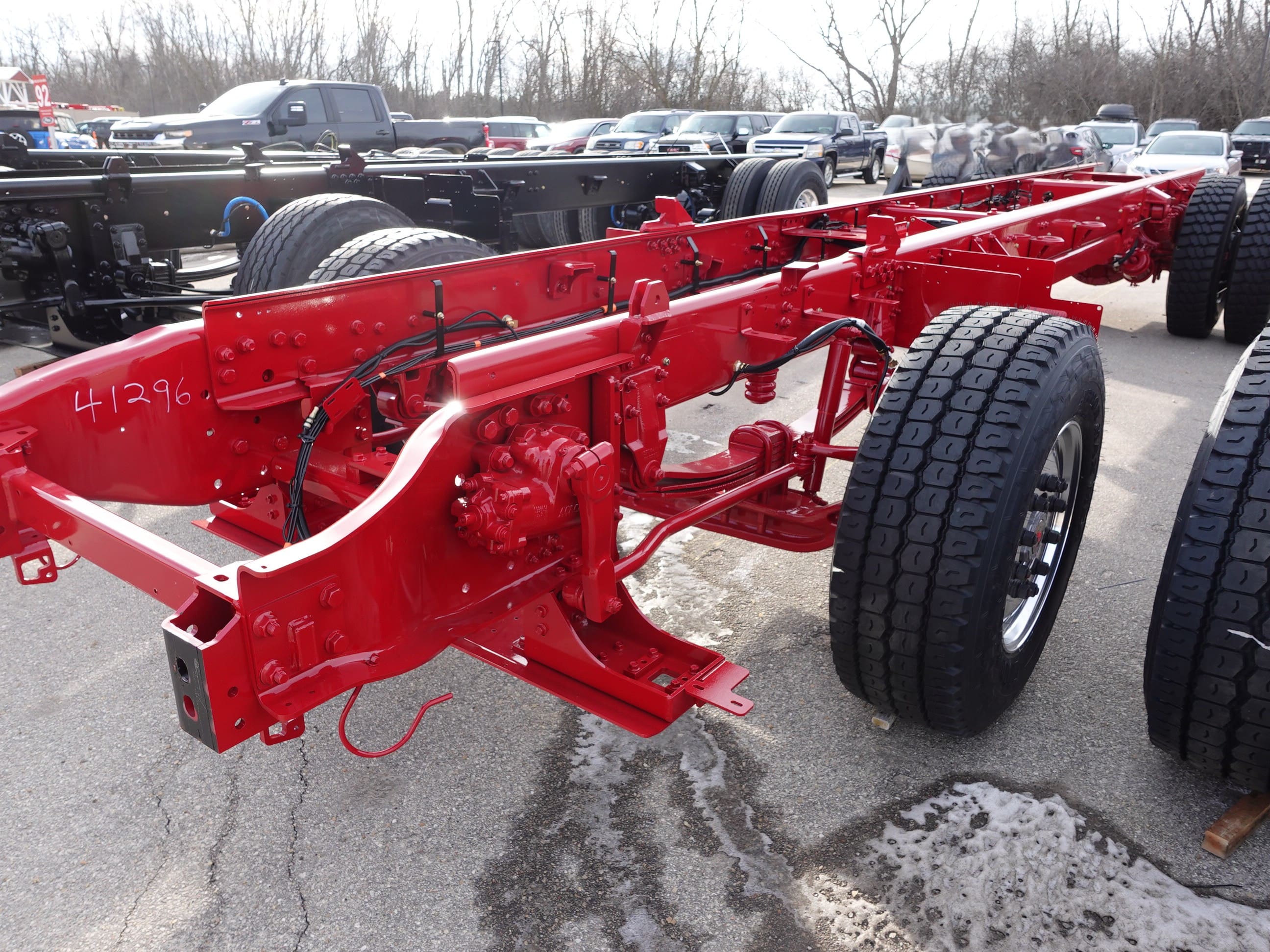

In this report, the cab remained staged (no photos), the frame build began (in WI), the pump house began initial assembly, and the body continued the fabrication process.

02-20-26

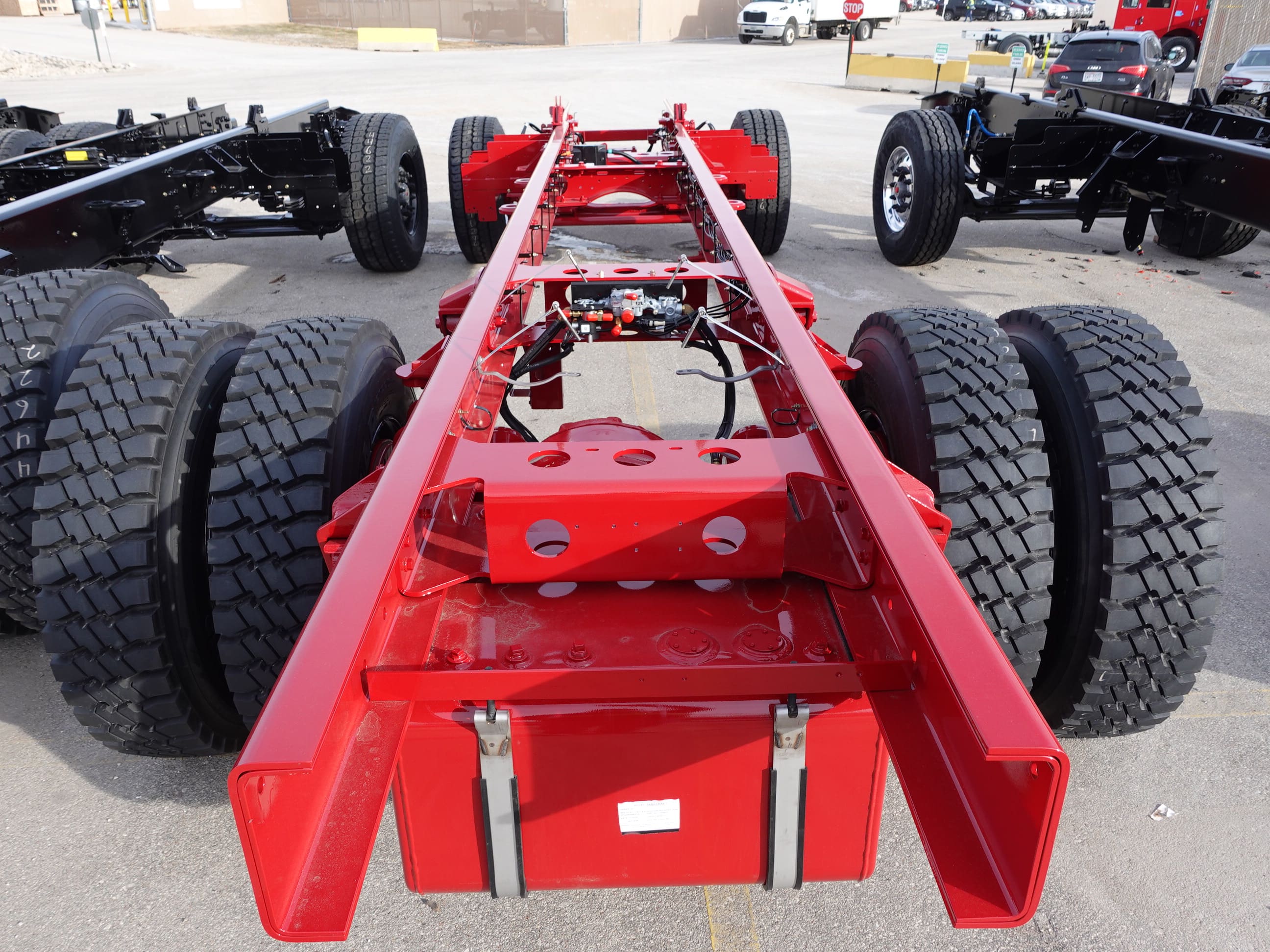

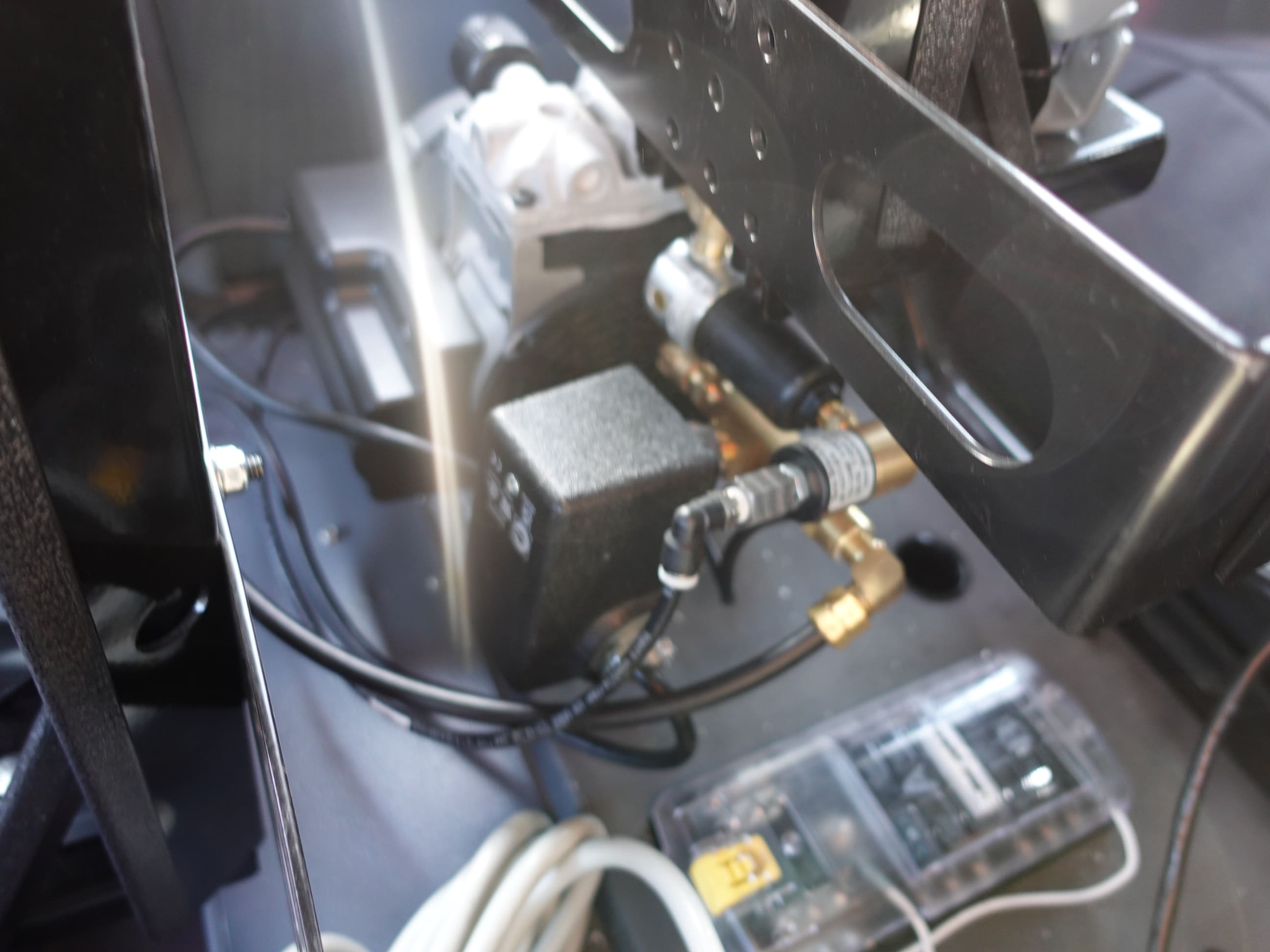

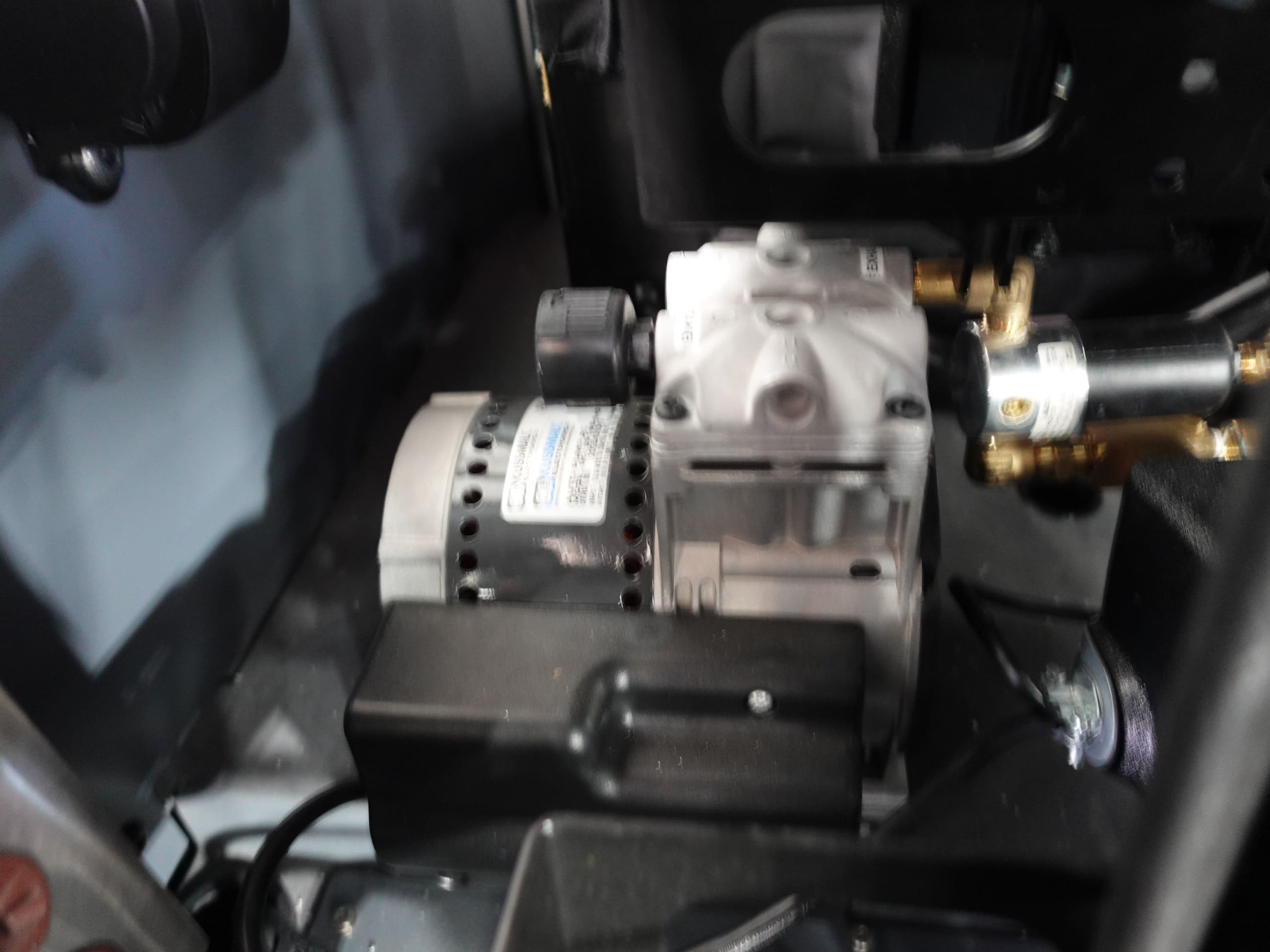

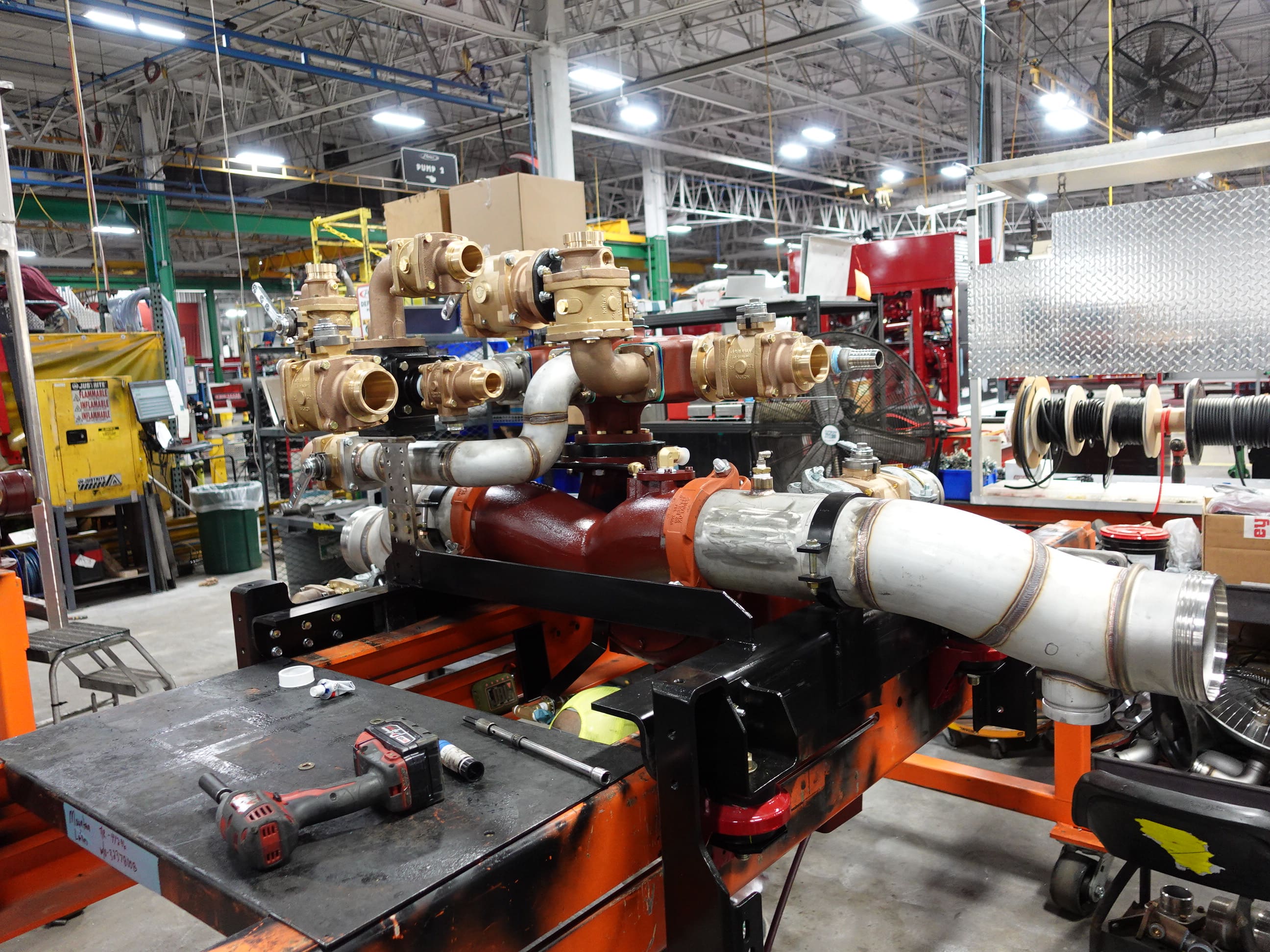

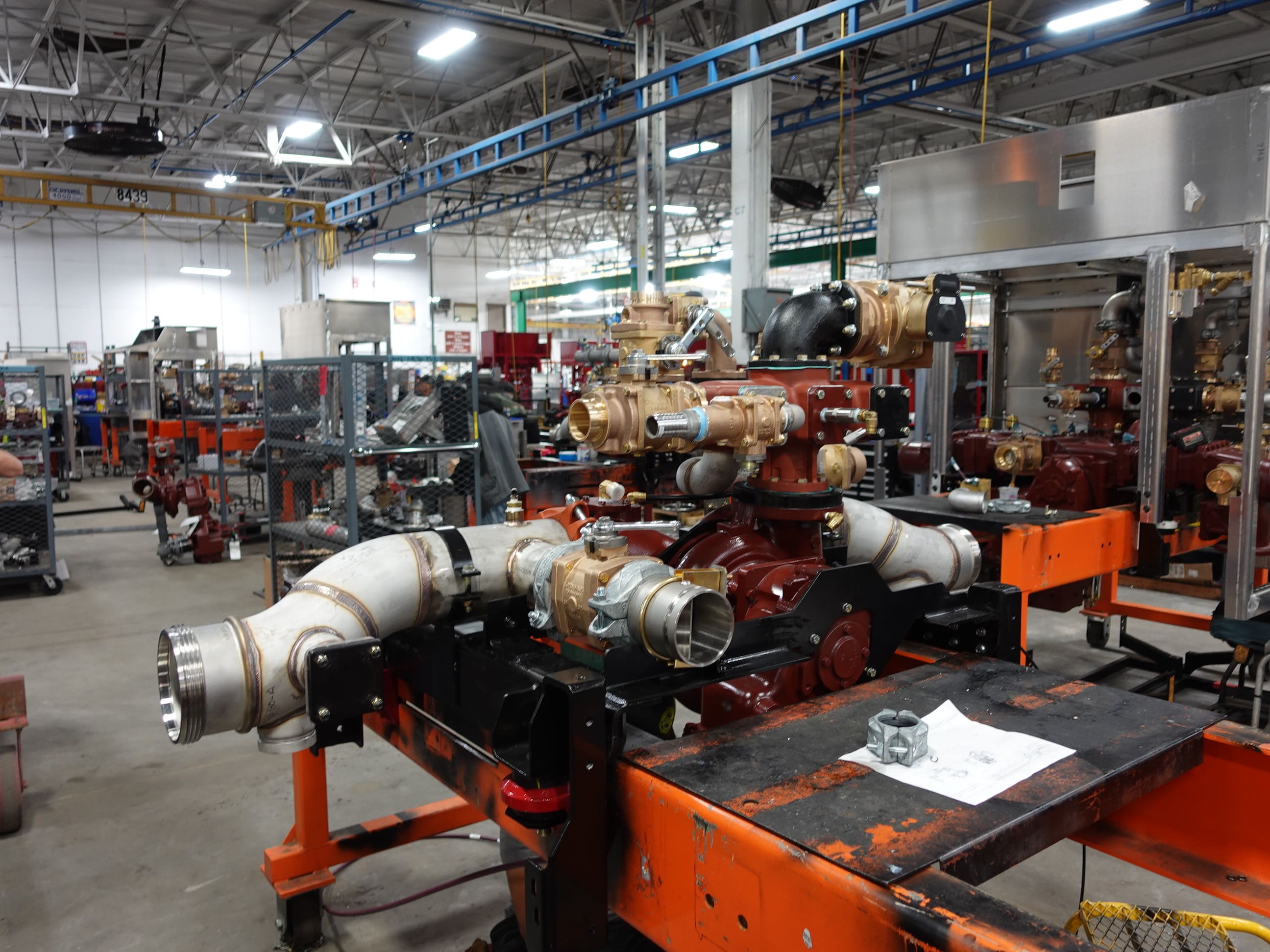

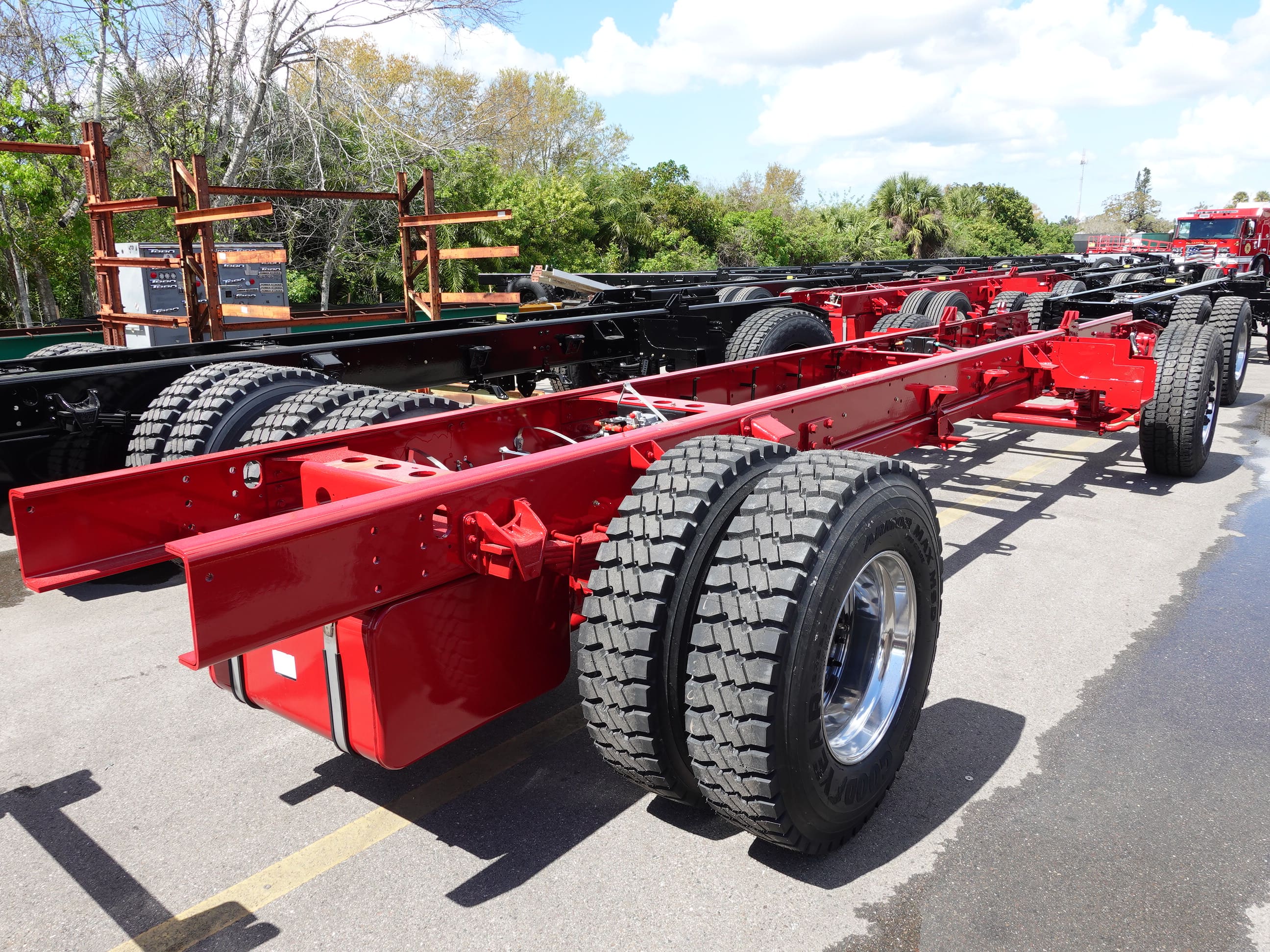

In this report, the cab was staged (no photos), the pump began assembly, and the body continued fabrication.

02-13-26

In this report, the cab was staged to begin the paint process while the body panels began fabrication.
