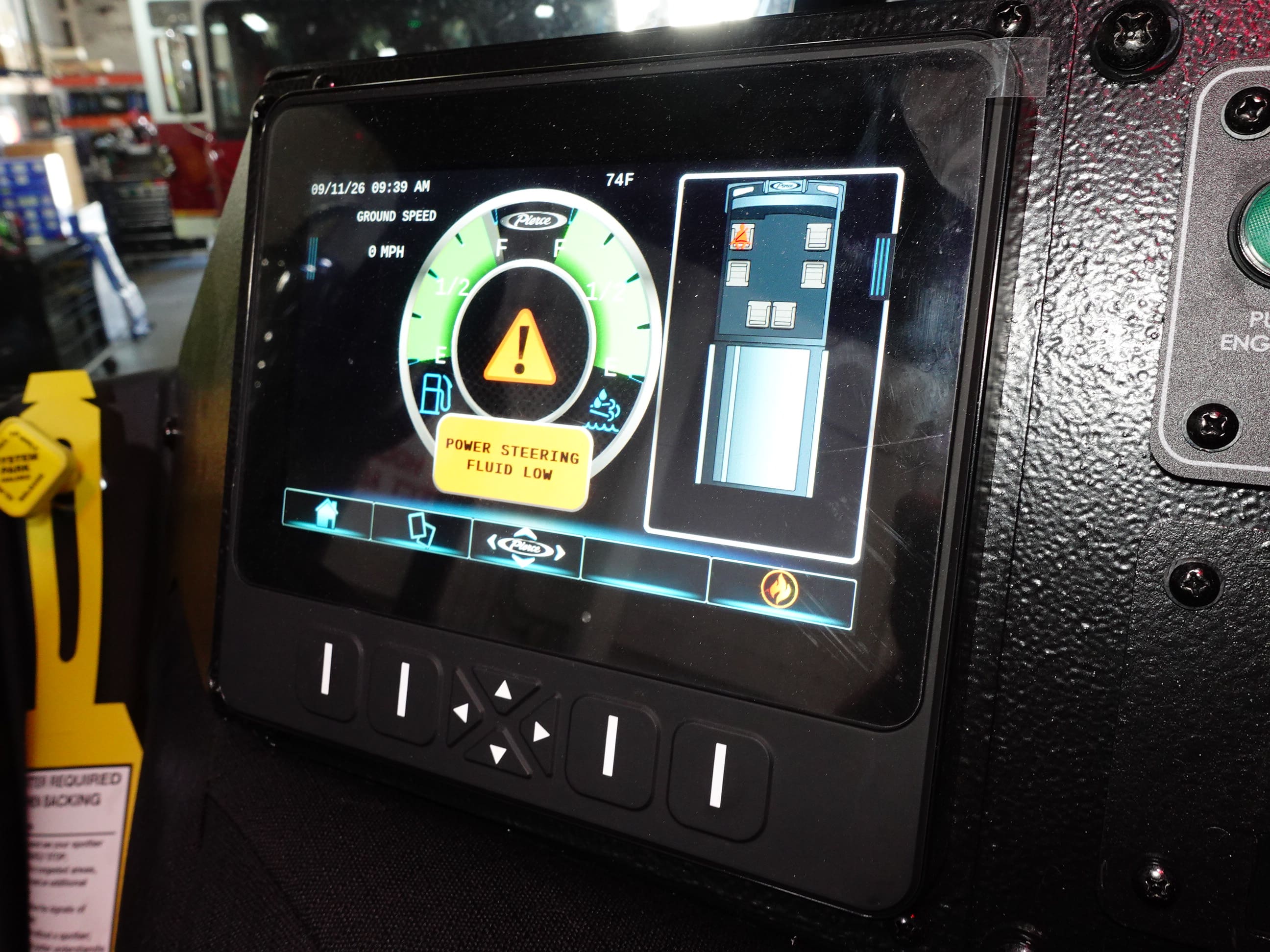

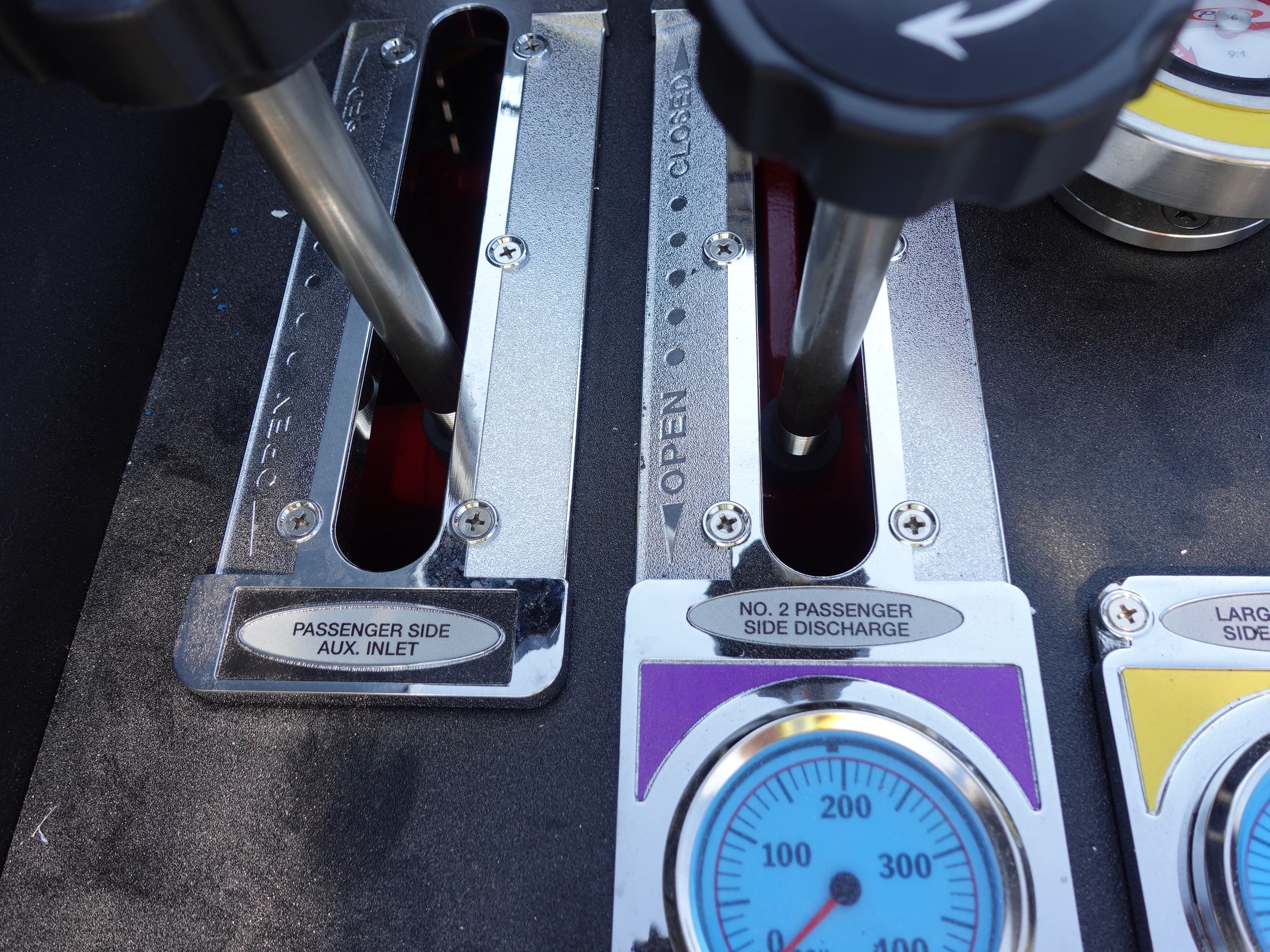

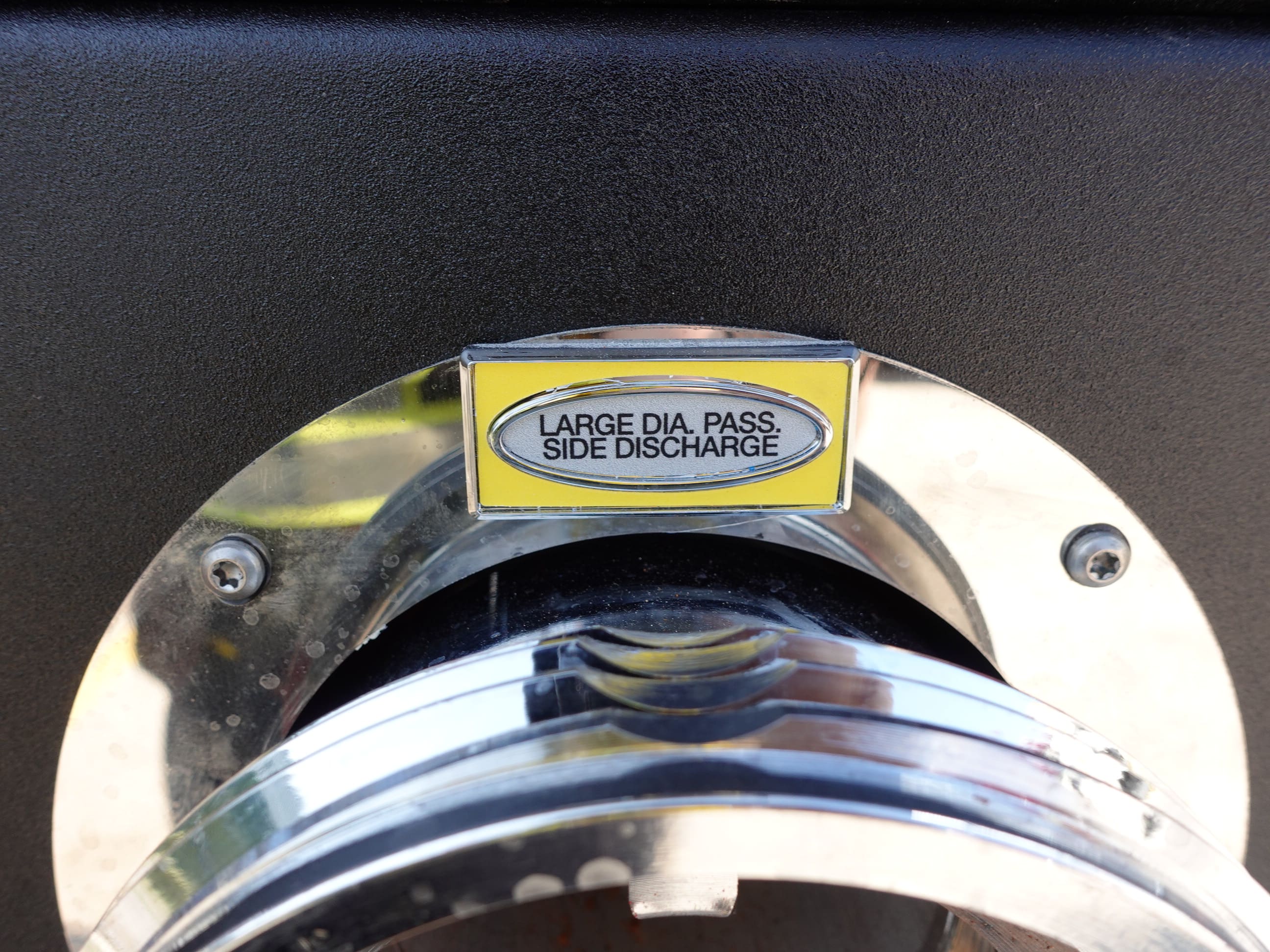

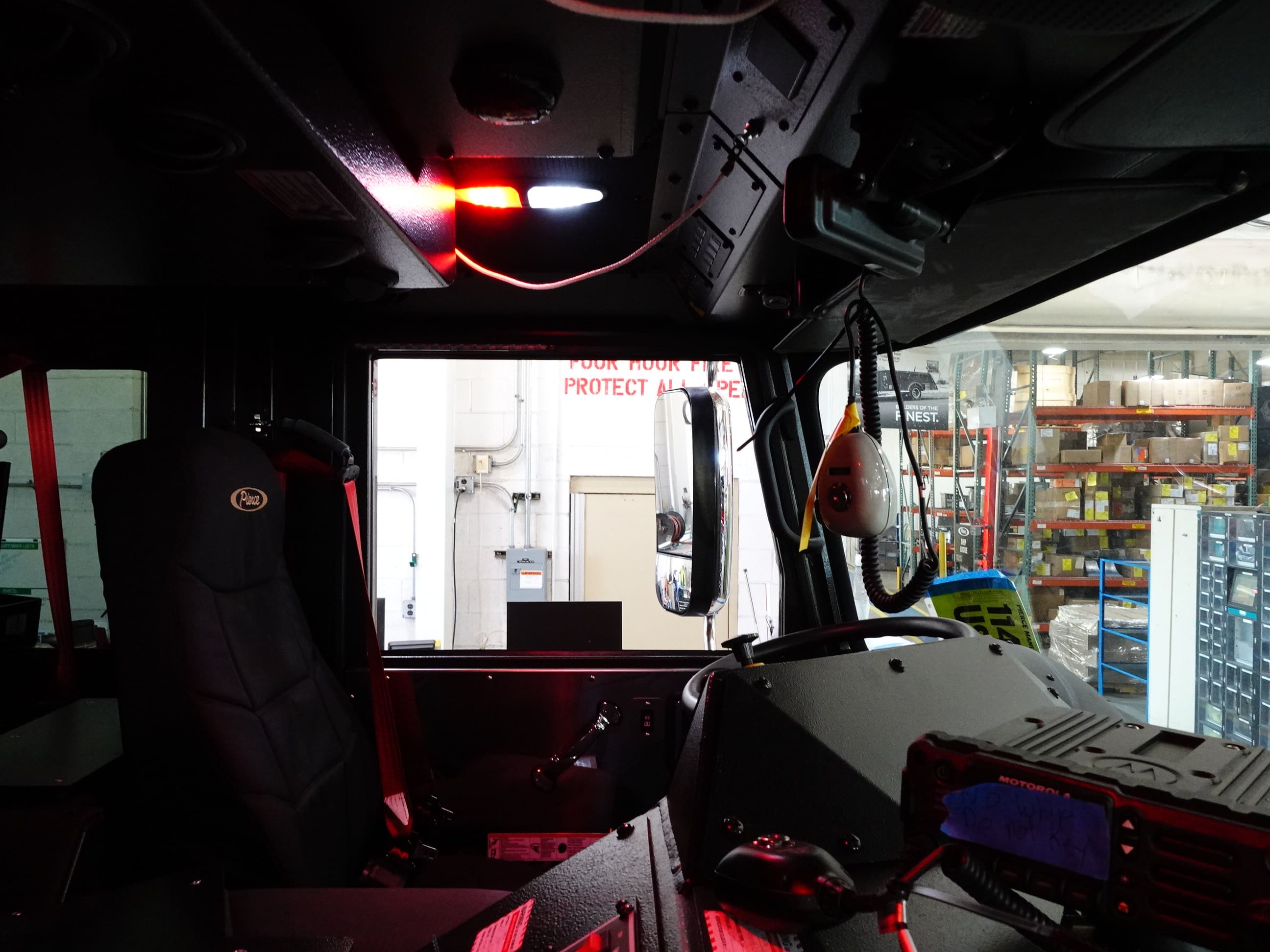

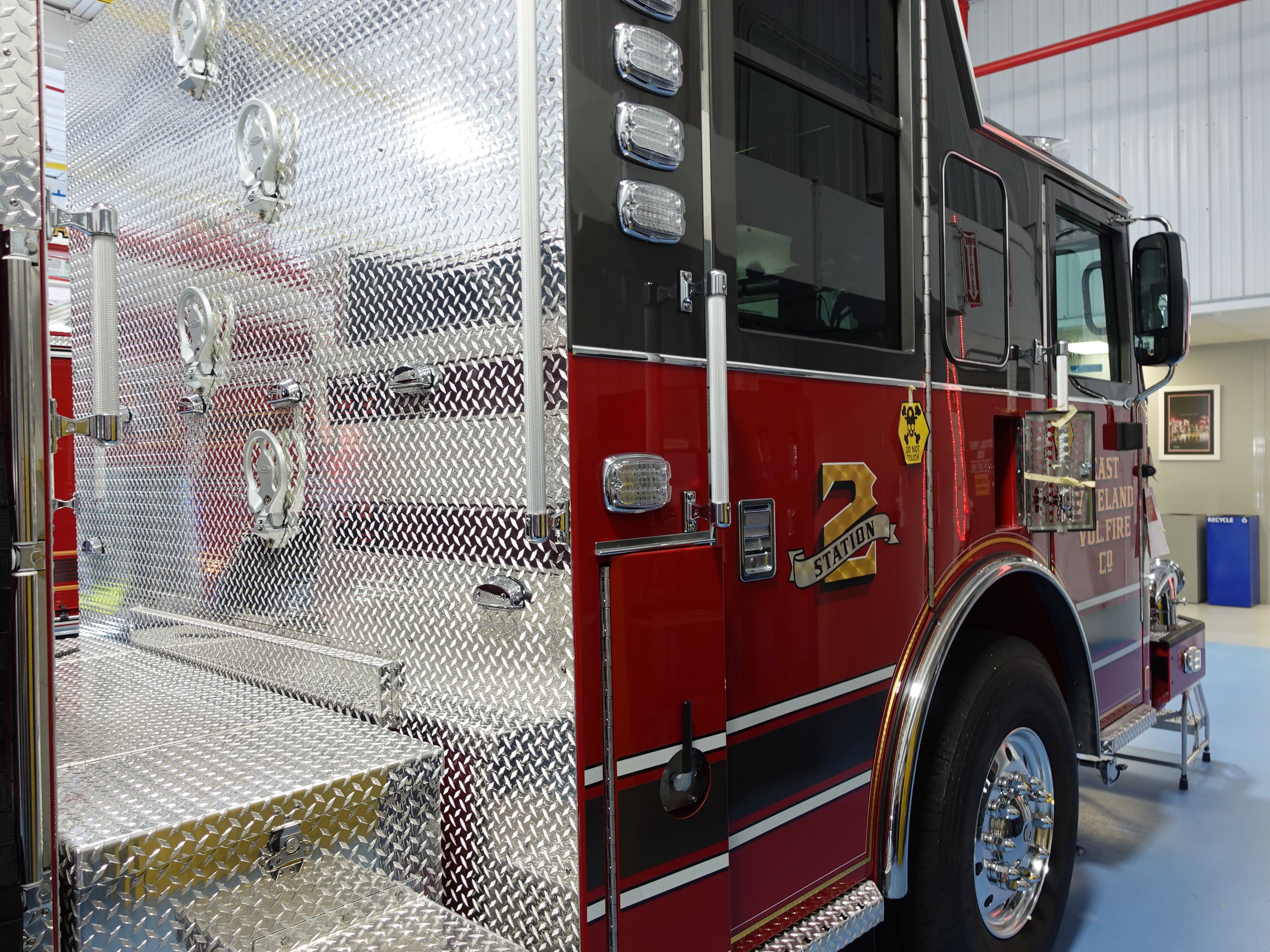

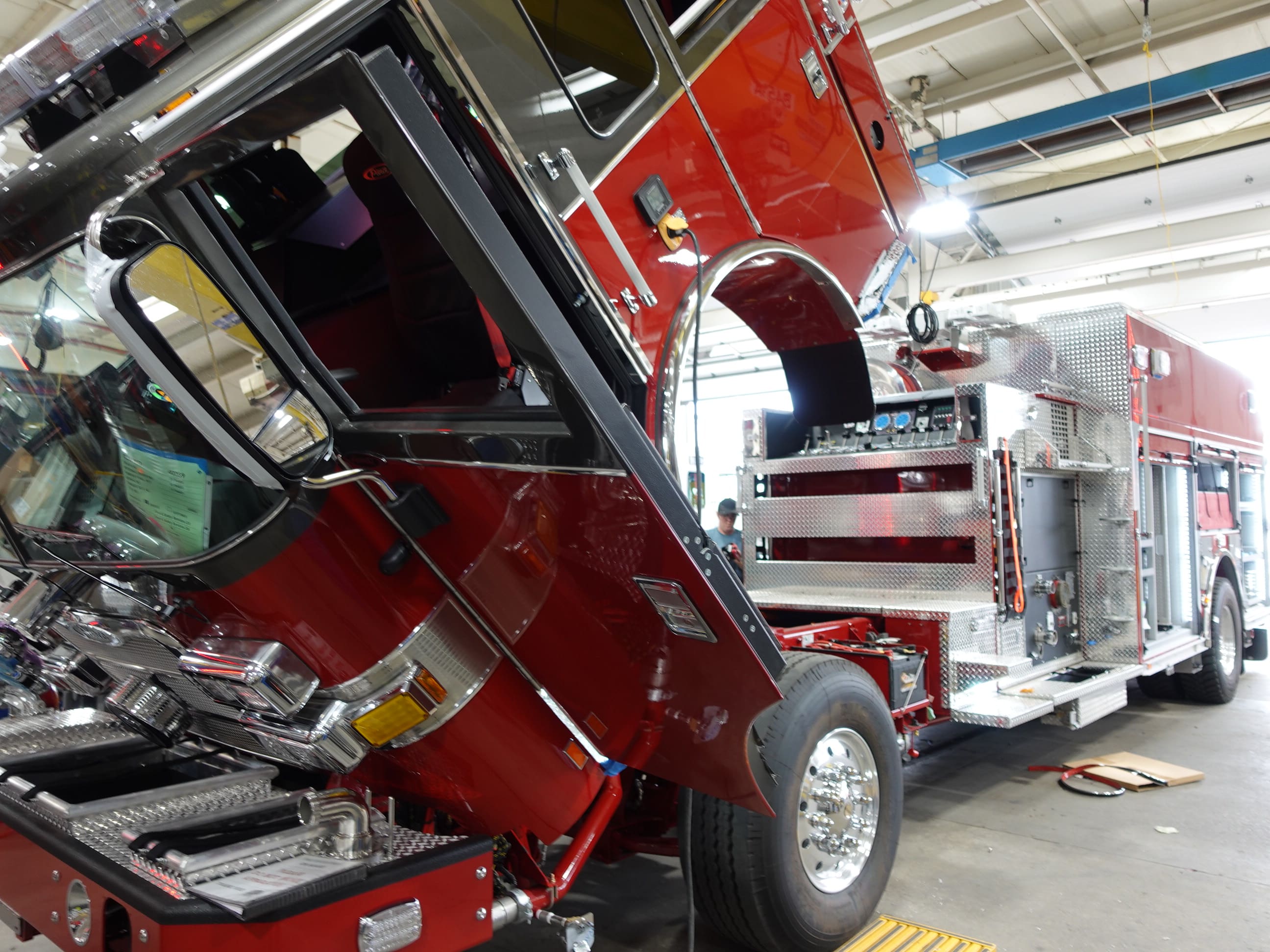

09-11-26

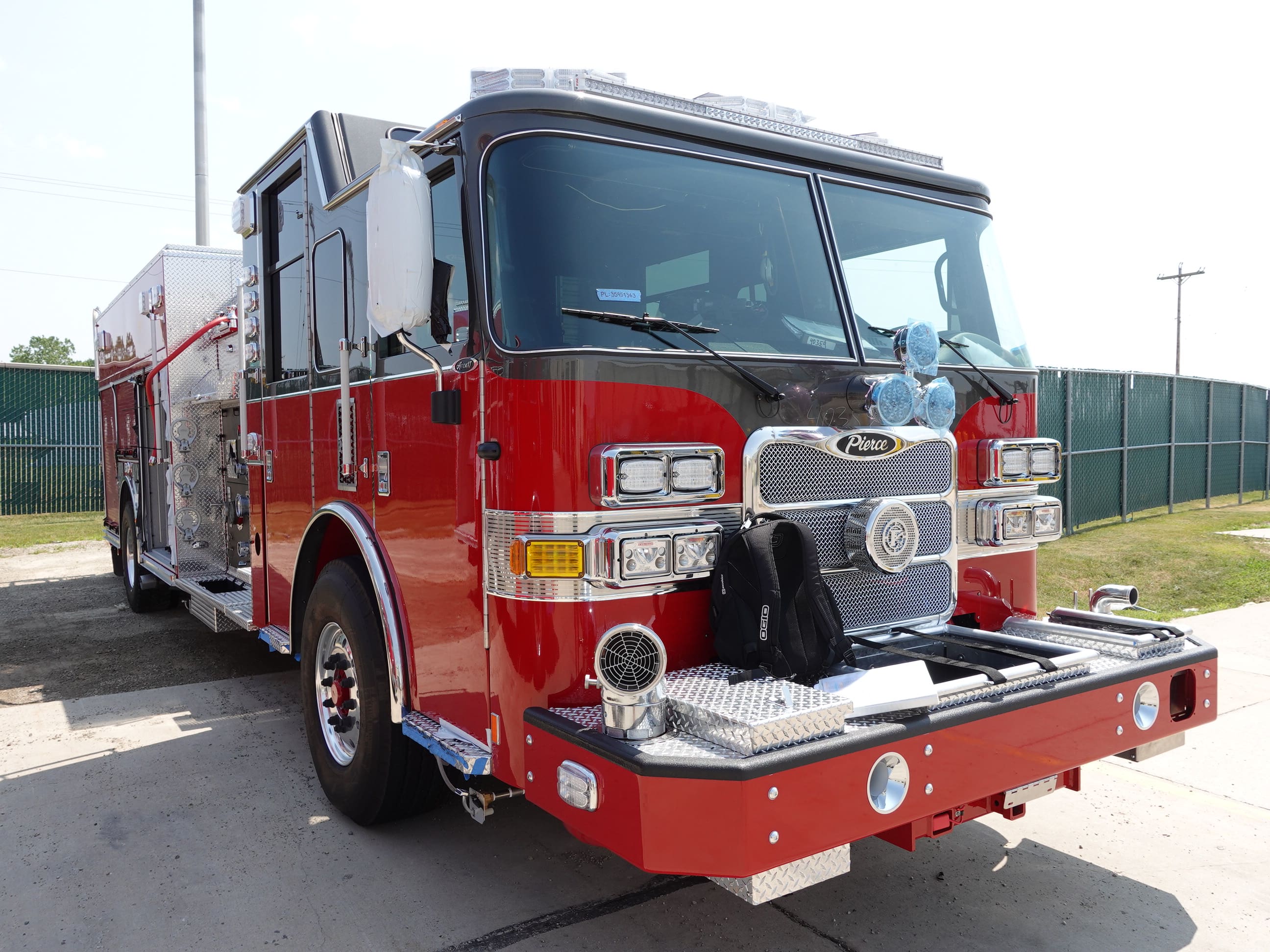

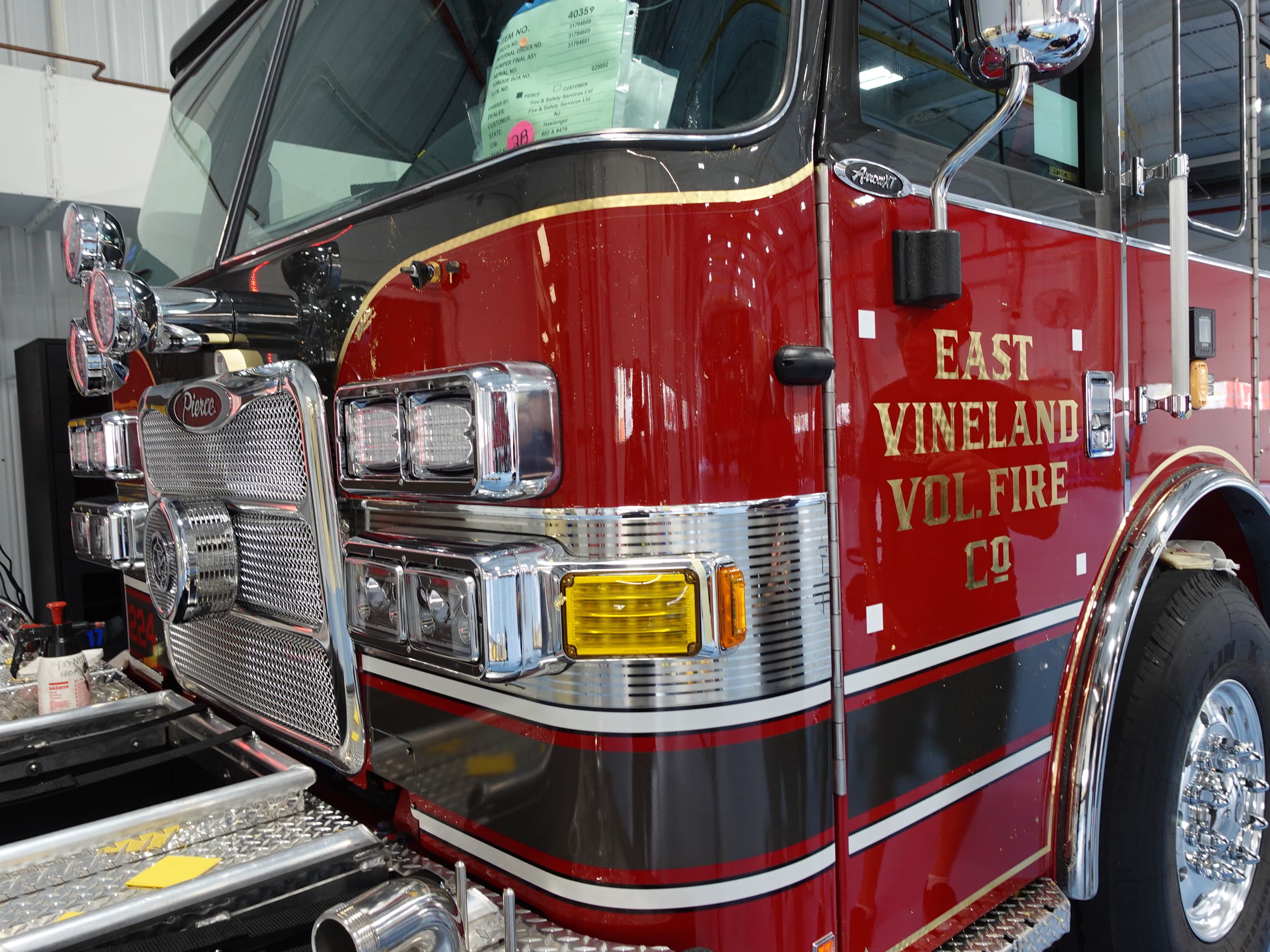

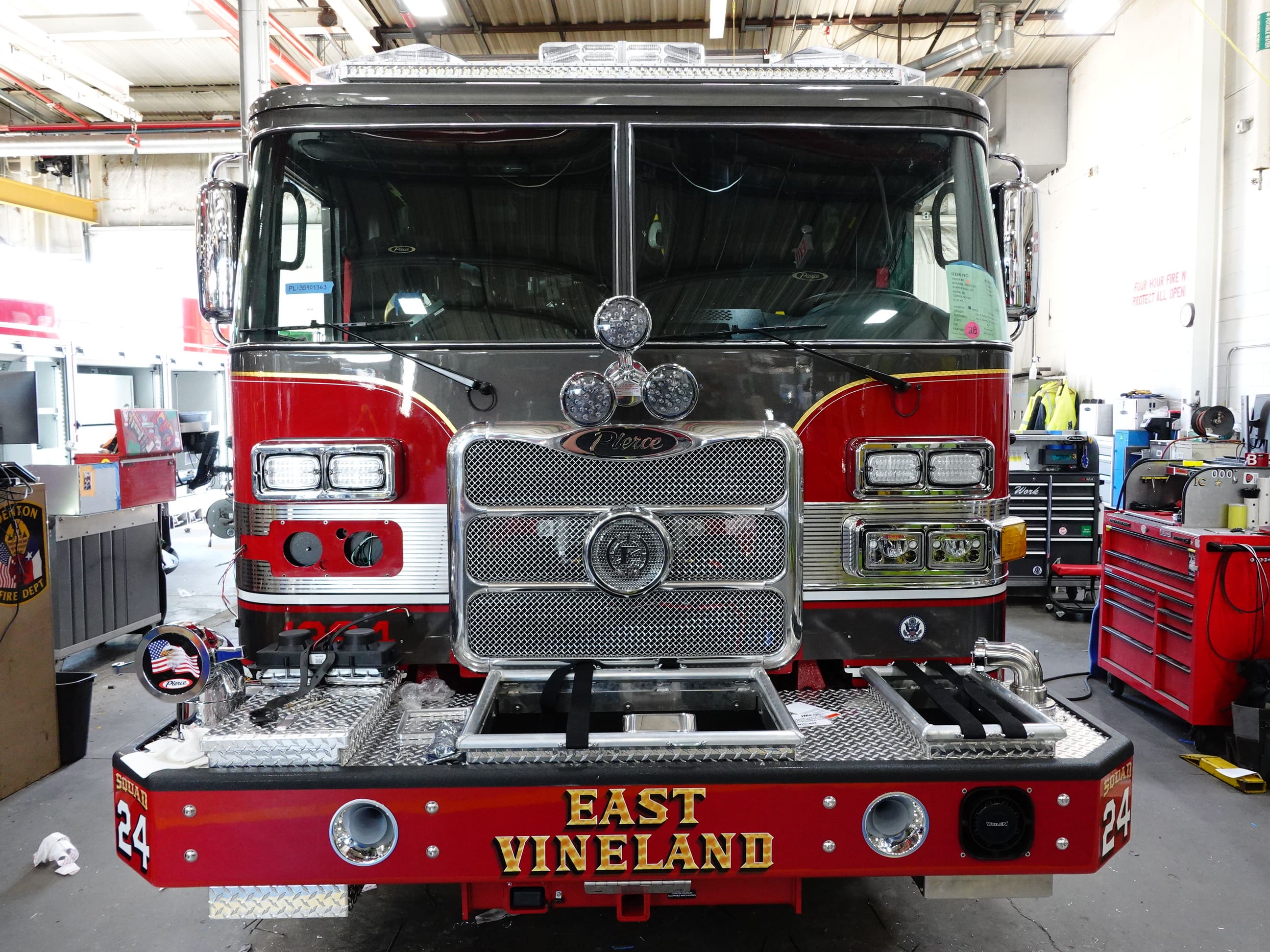

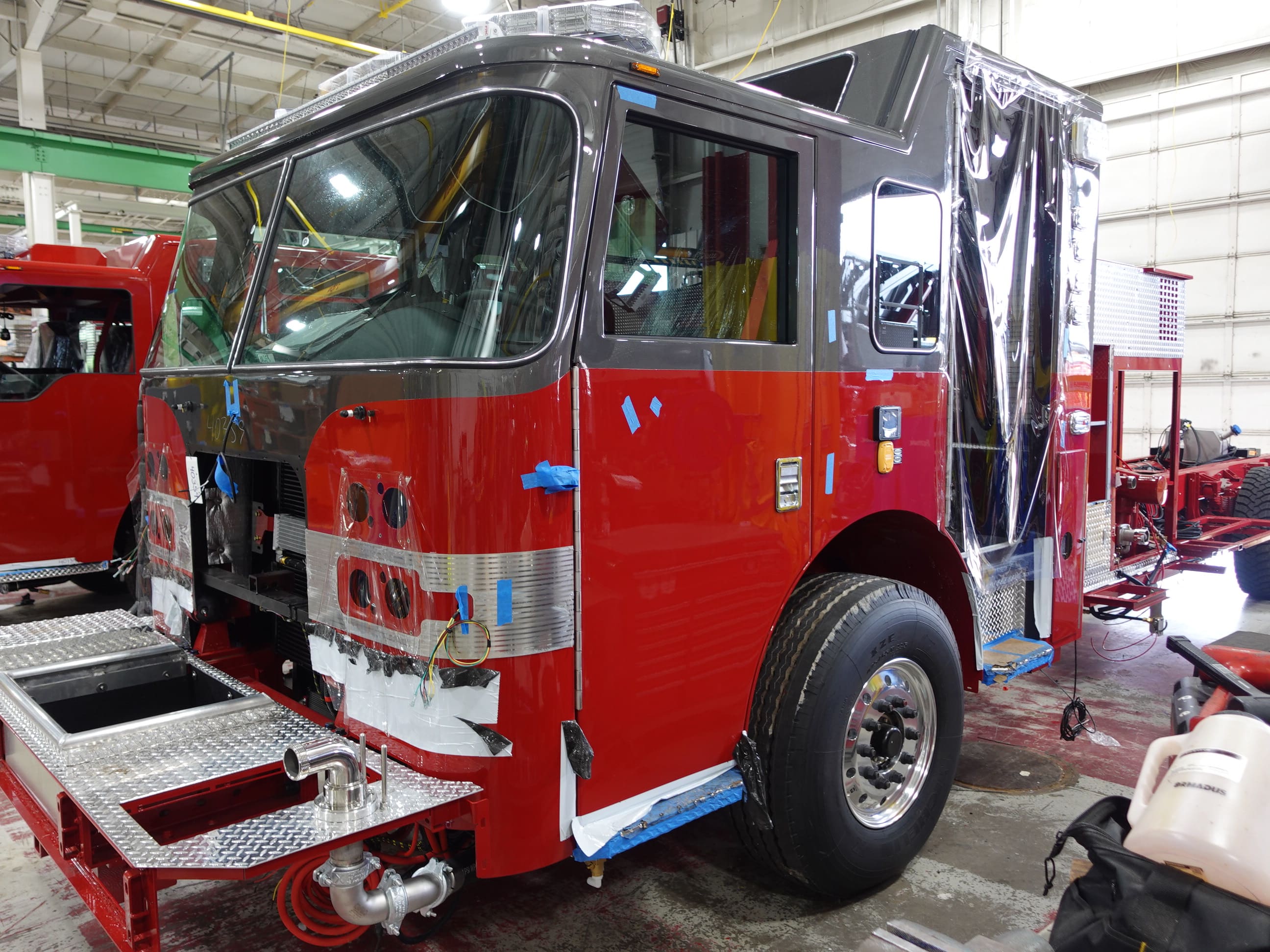

In this report, the apparatus continued the quality process.

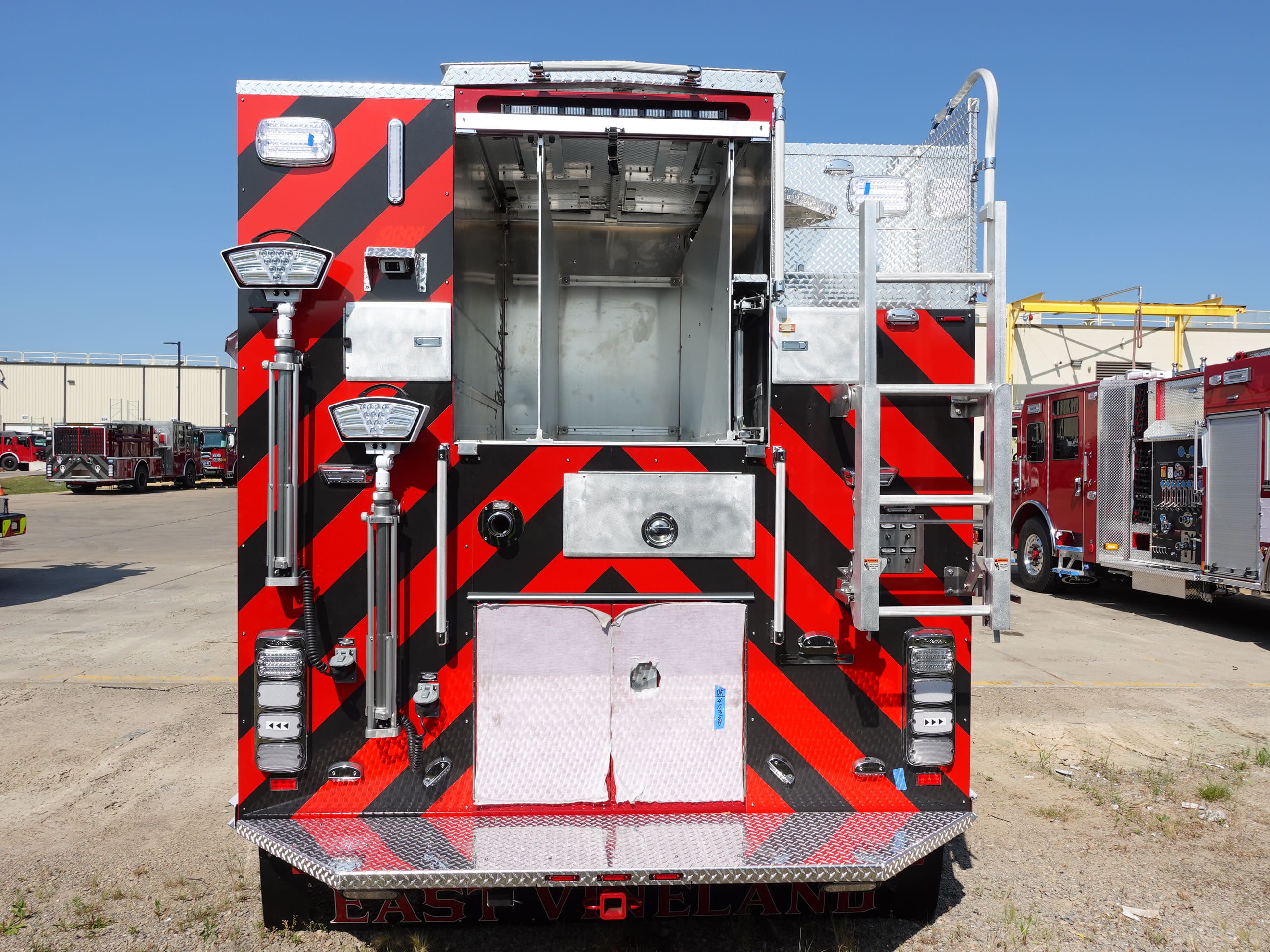

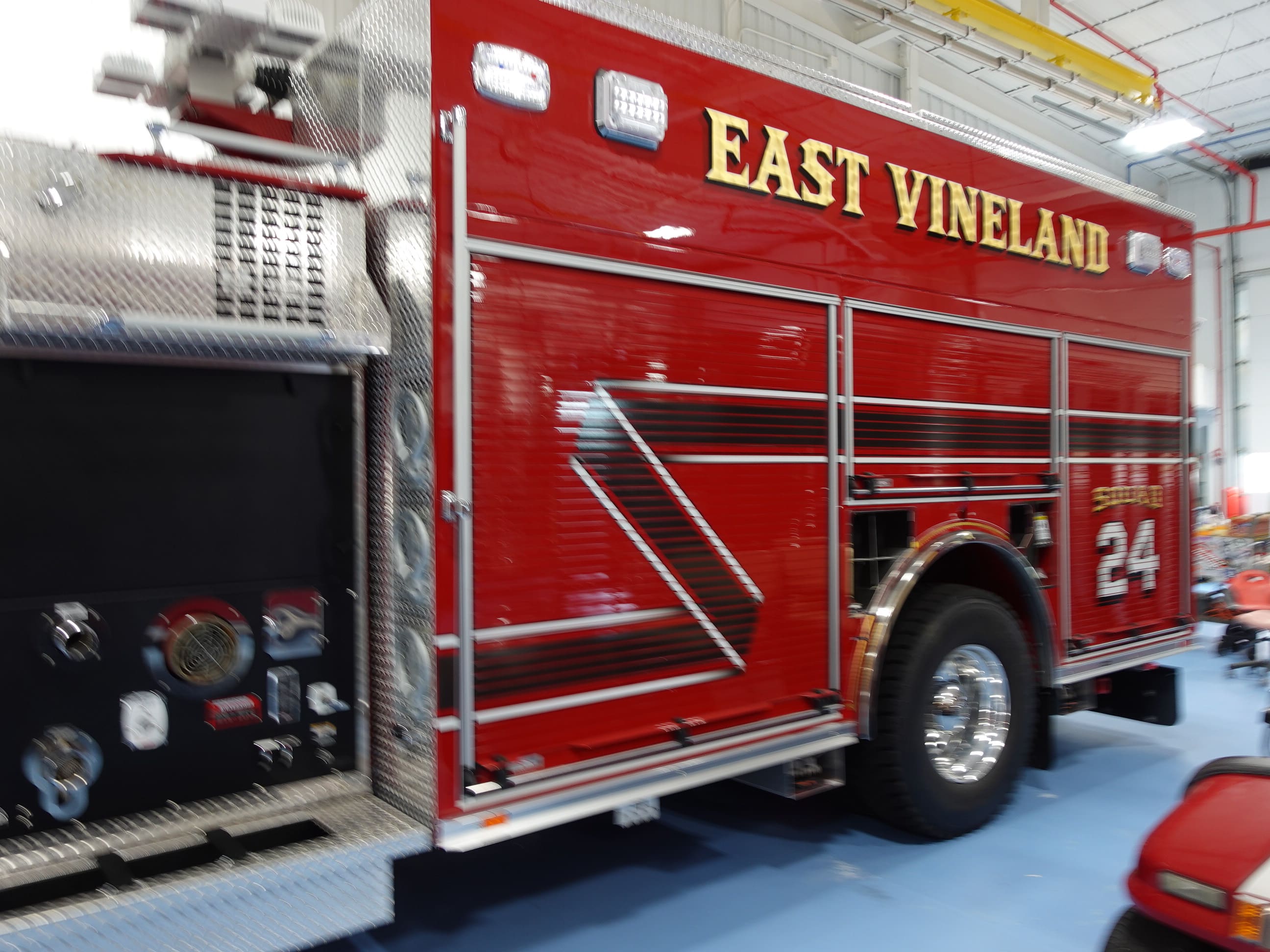

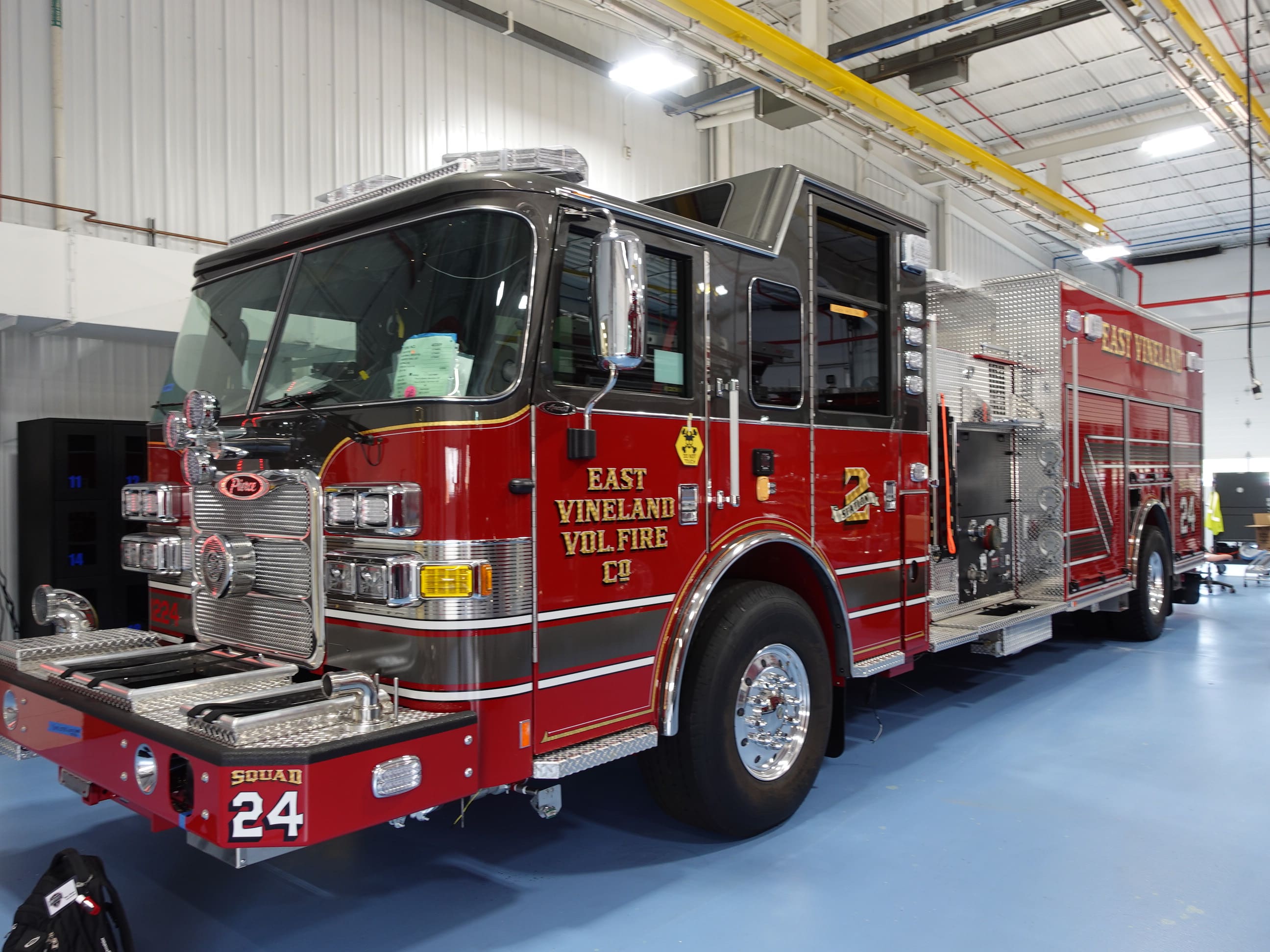

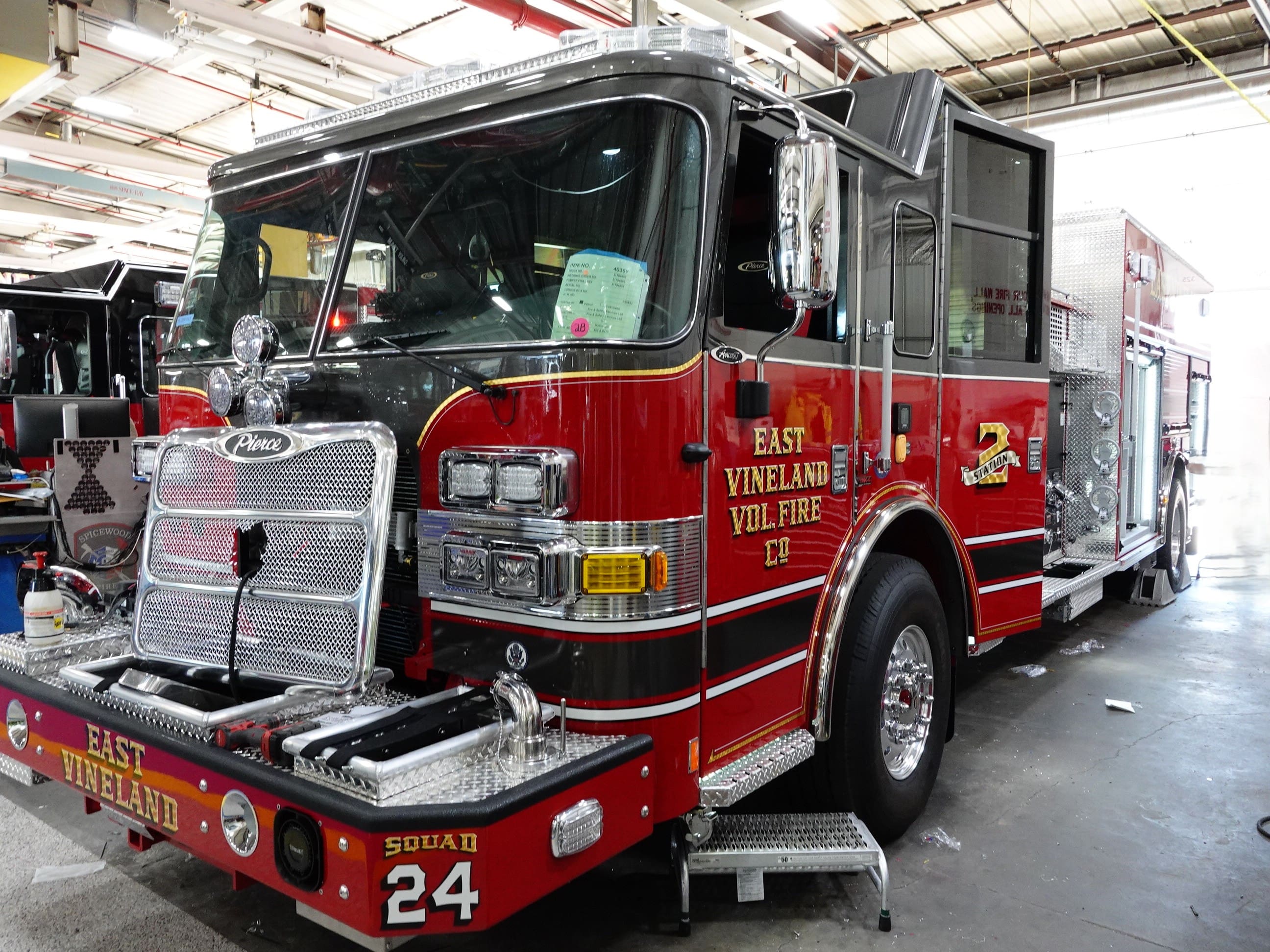

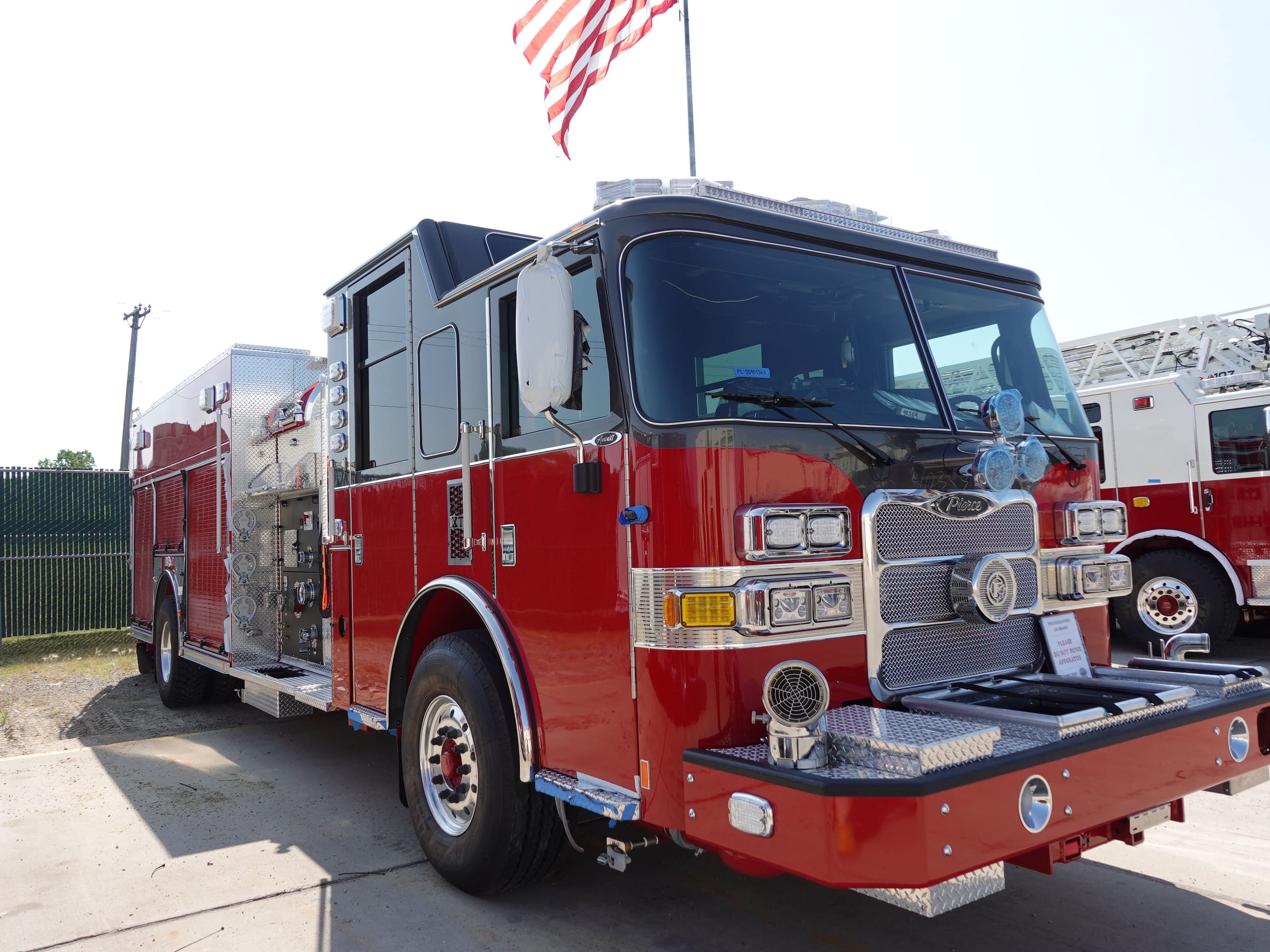

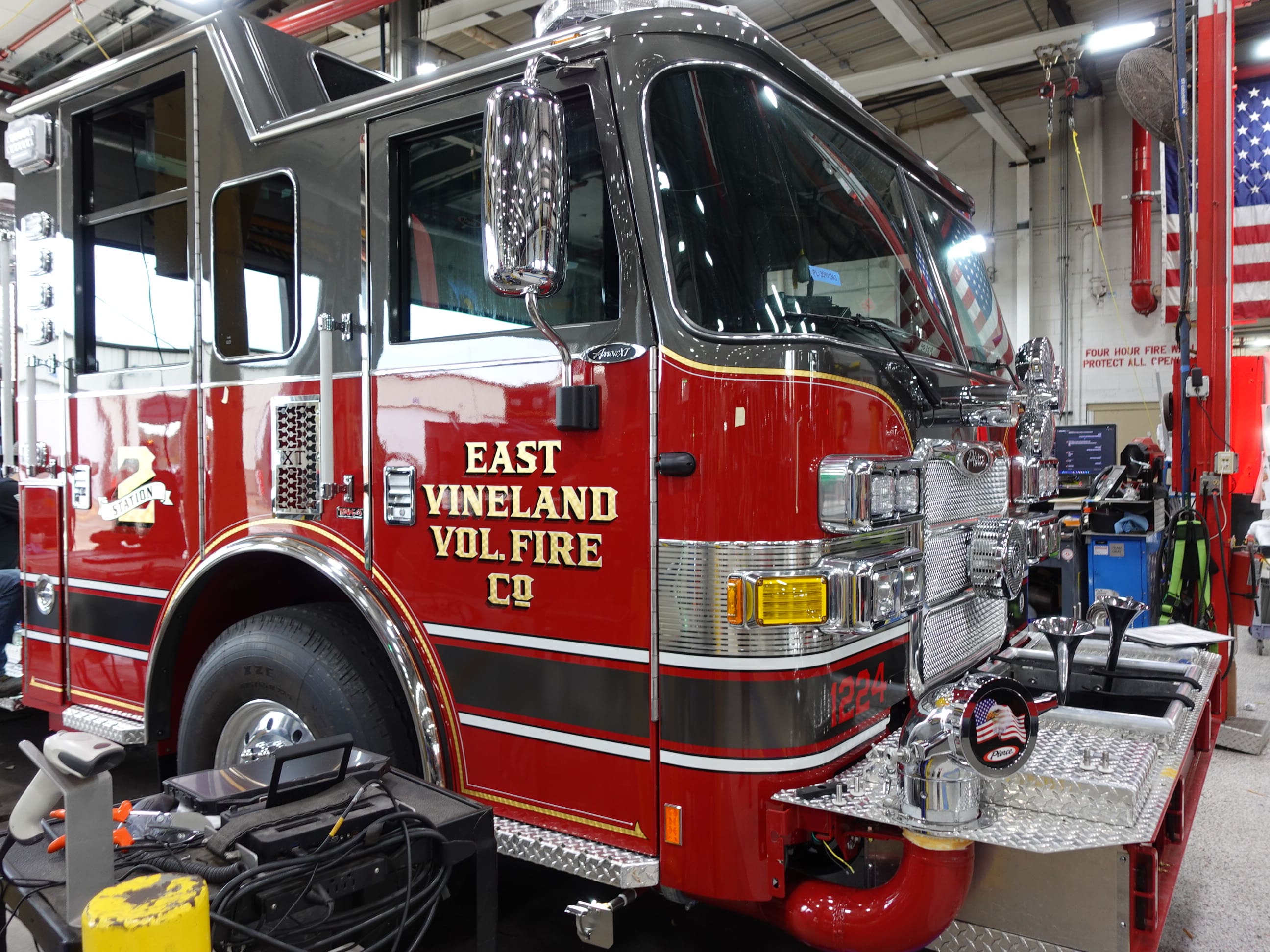

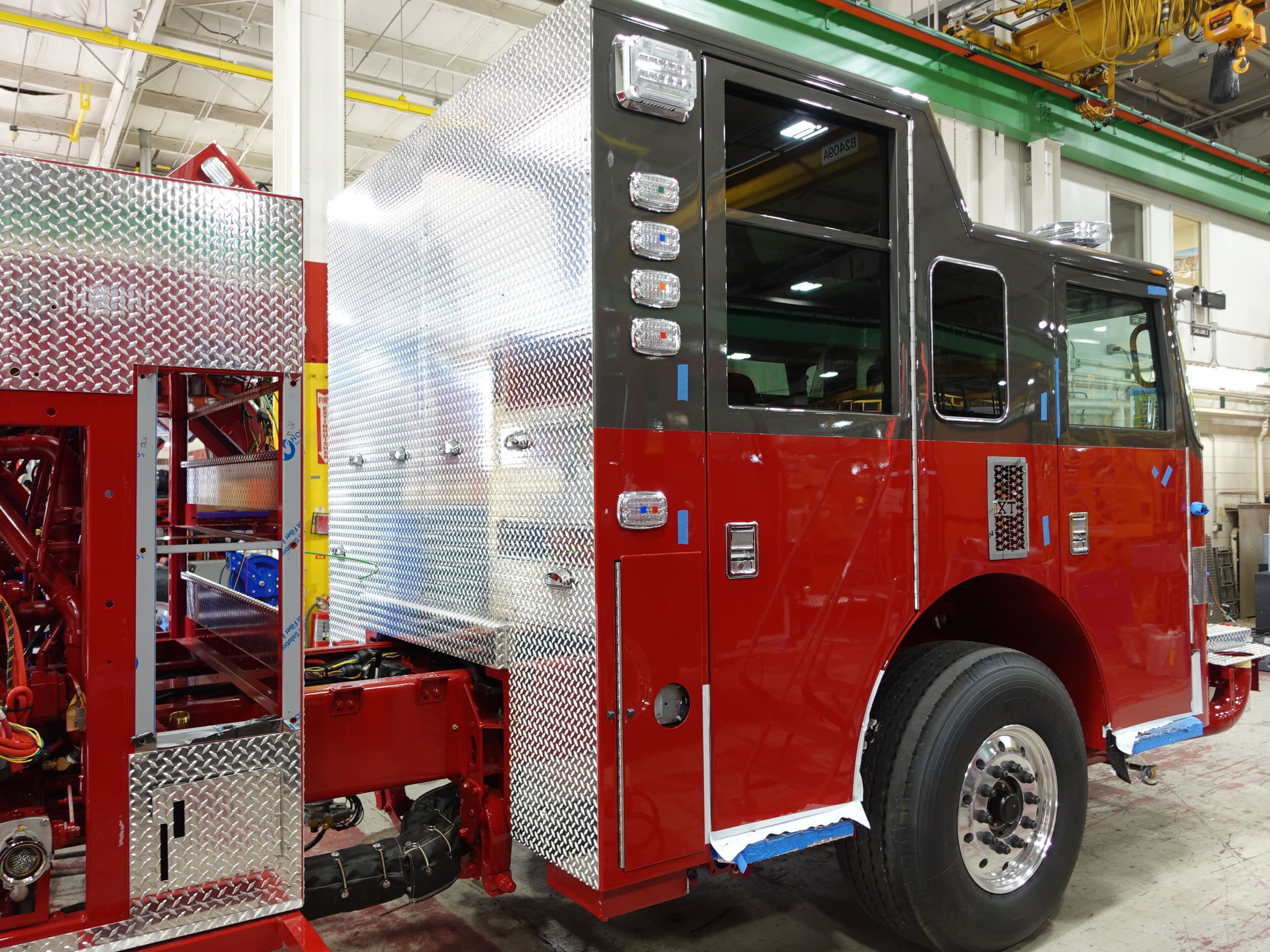

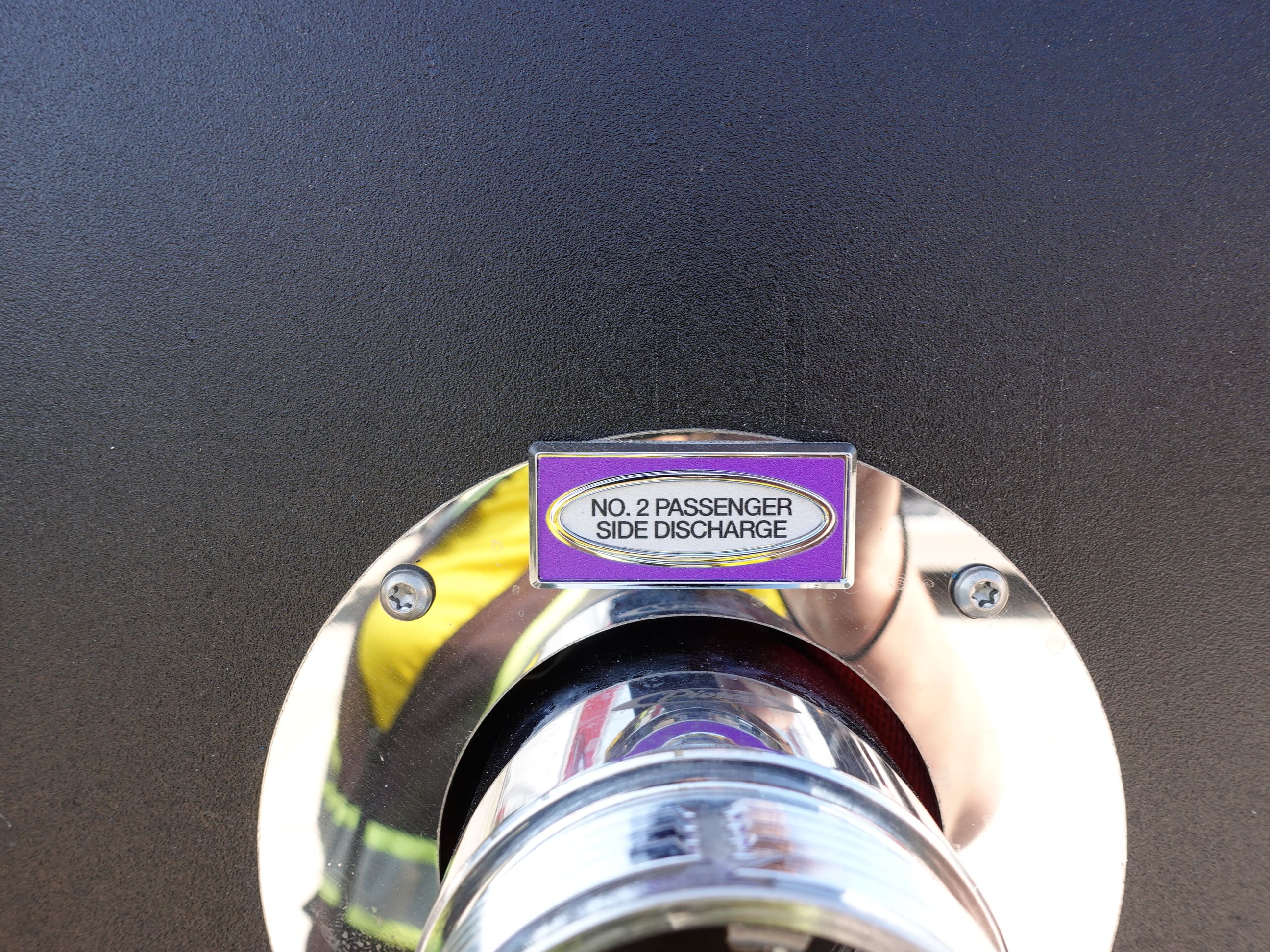

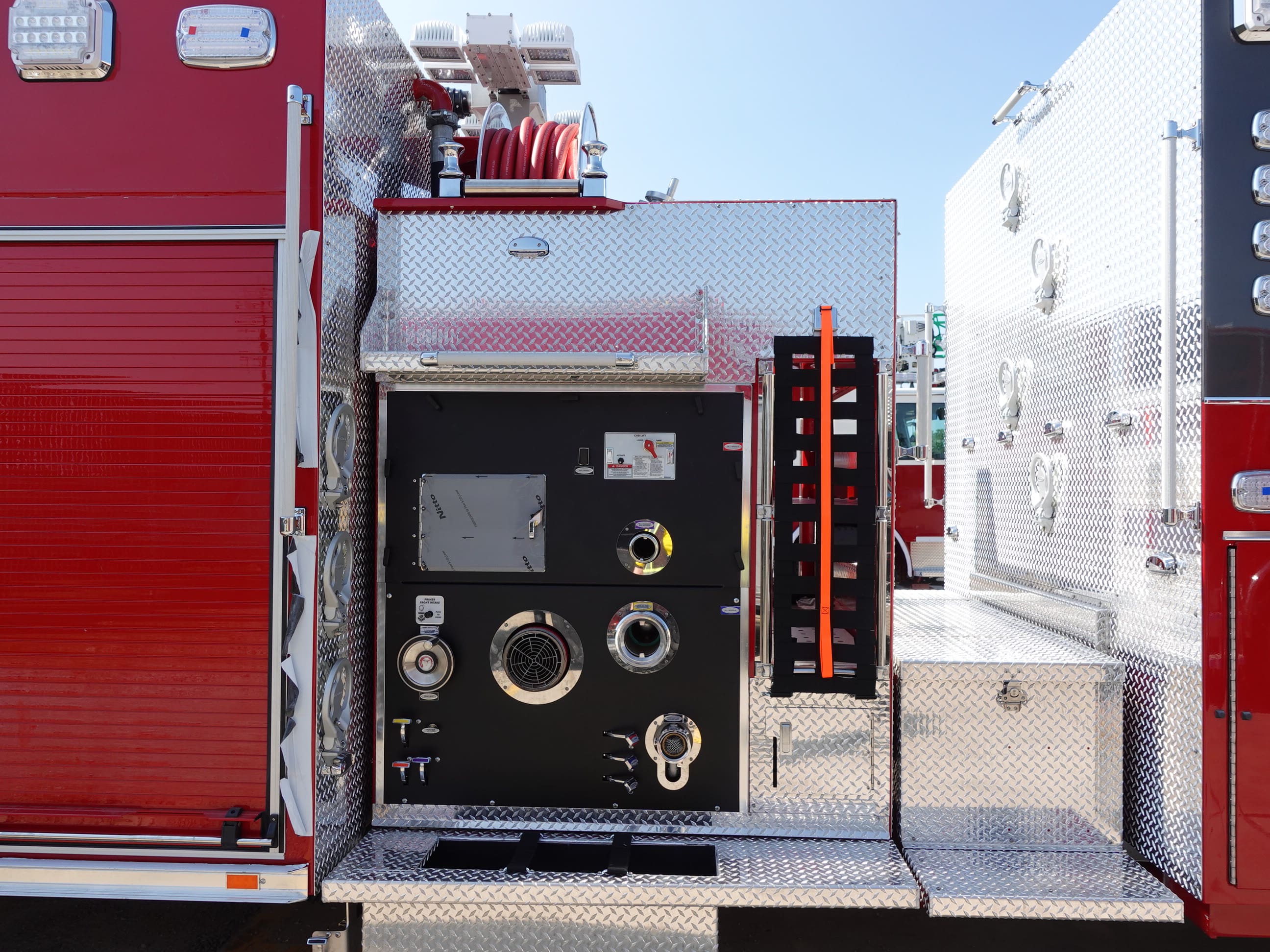

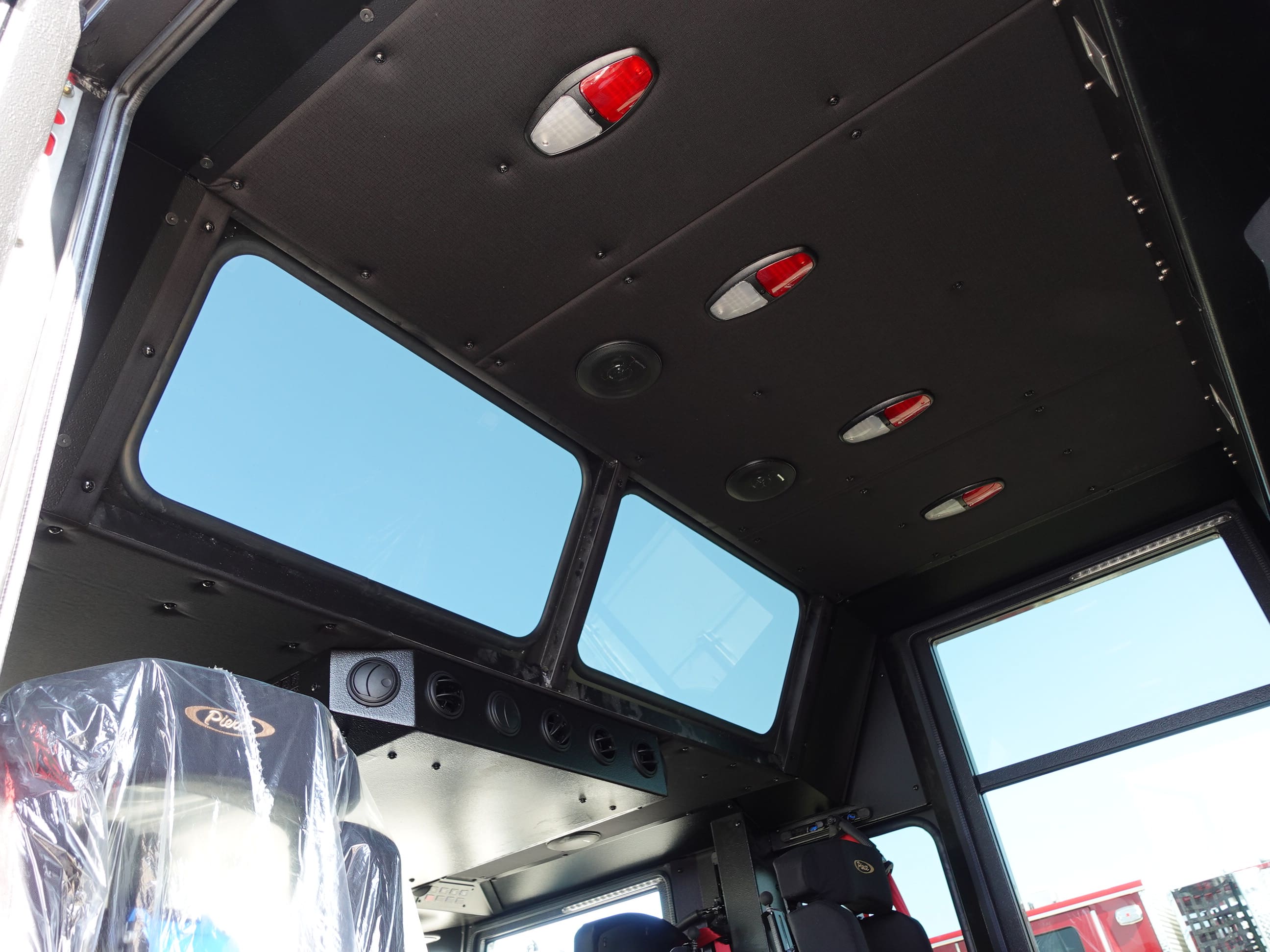

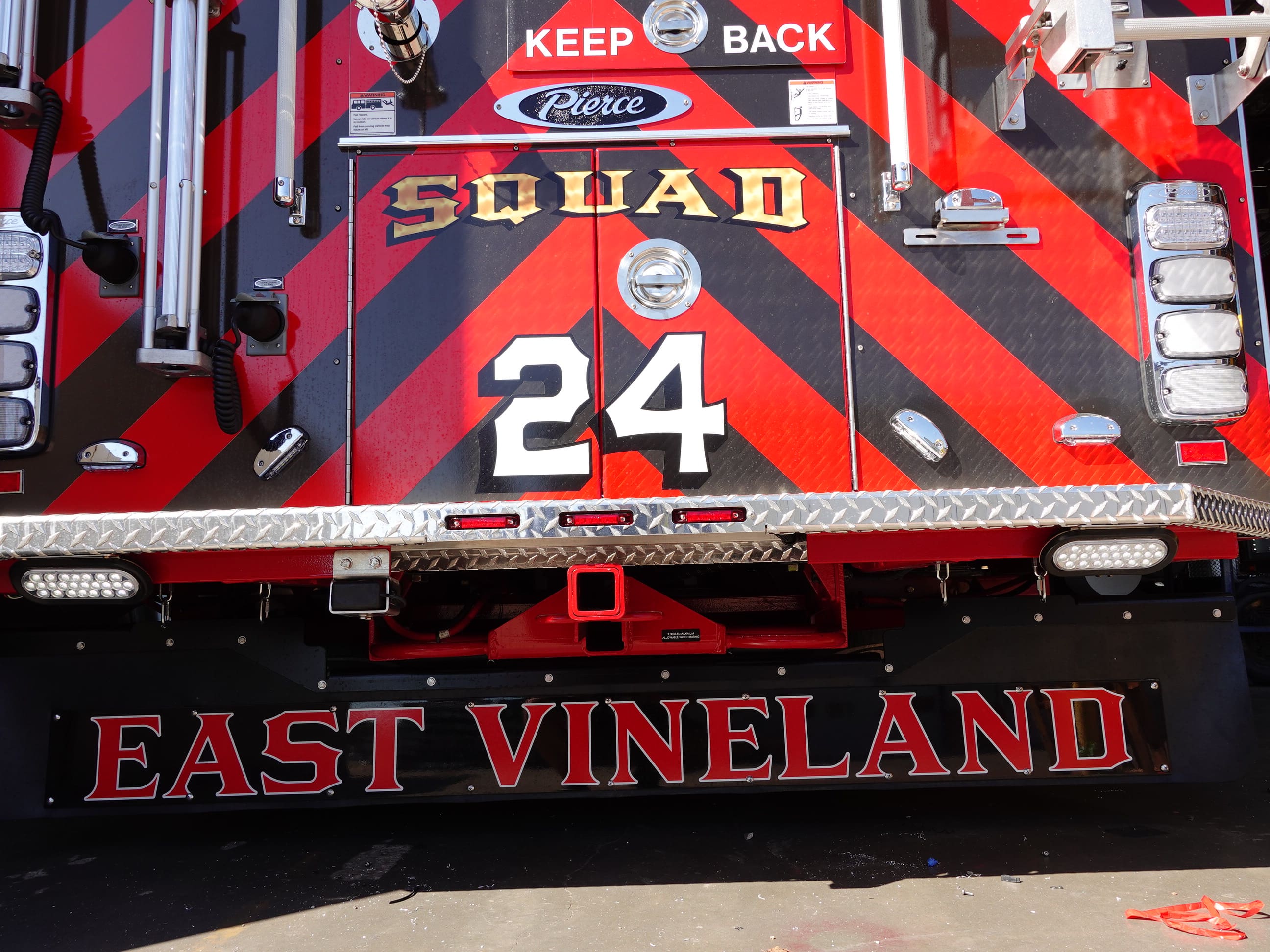

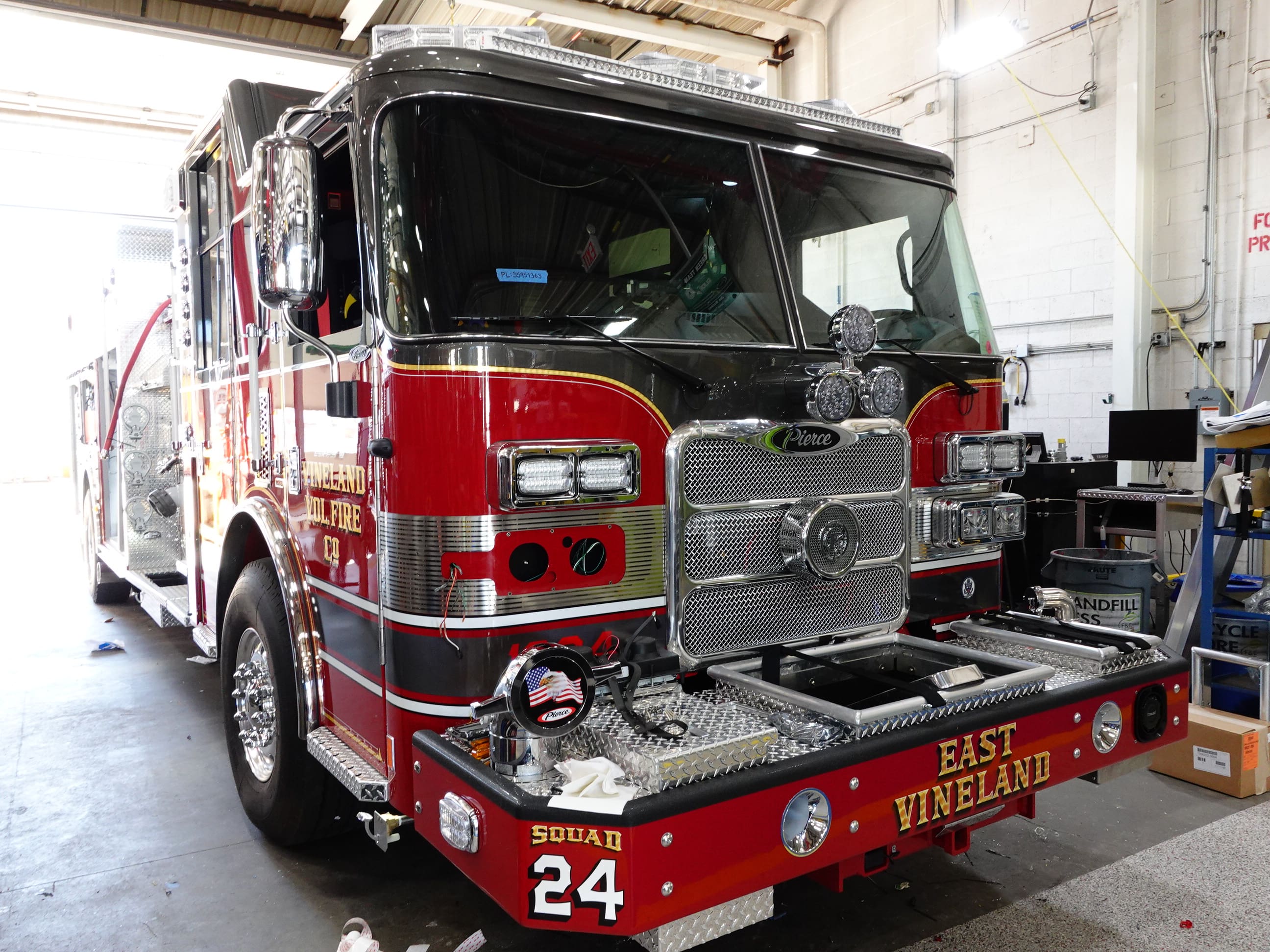

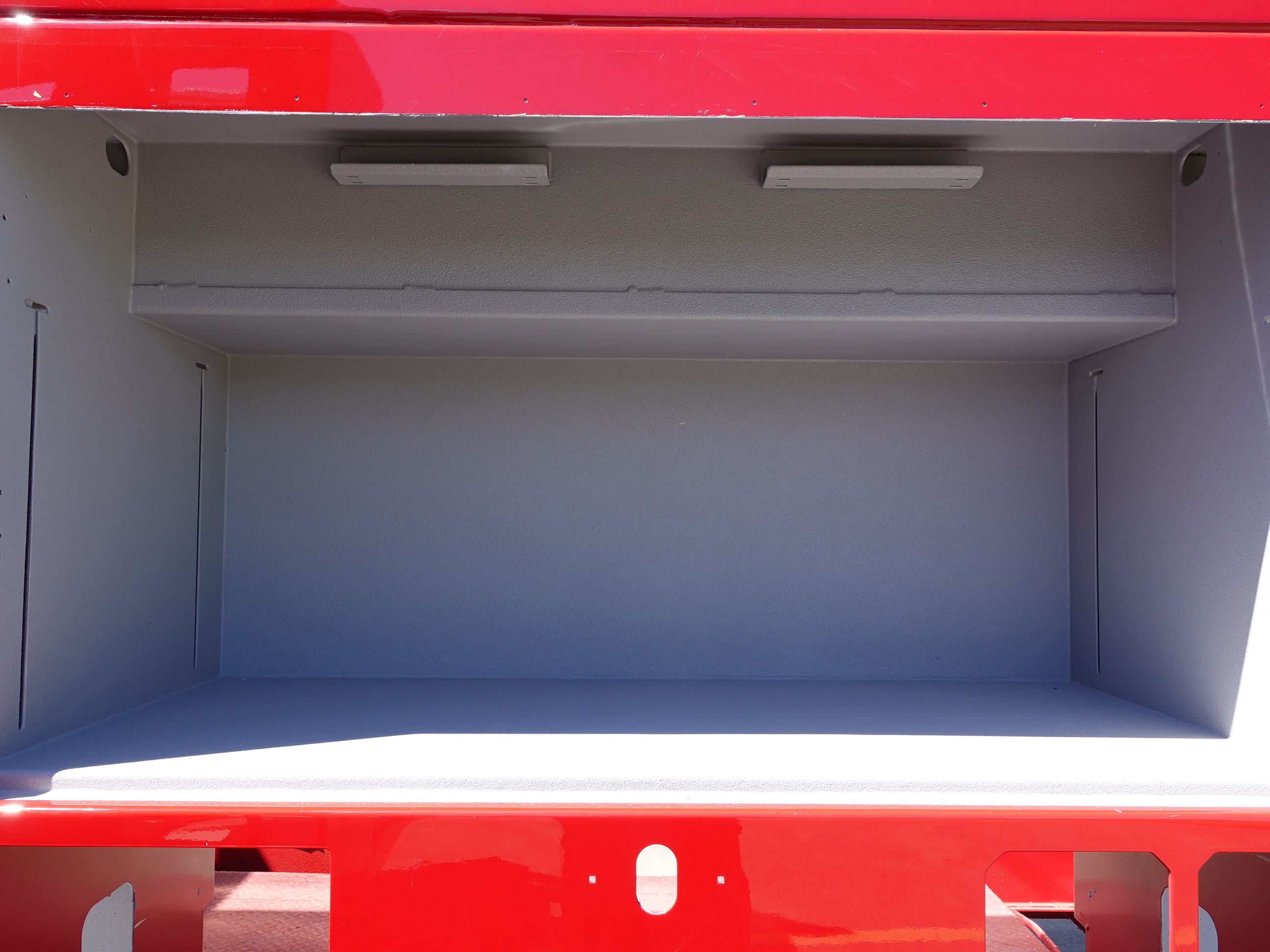

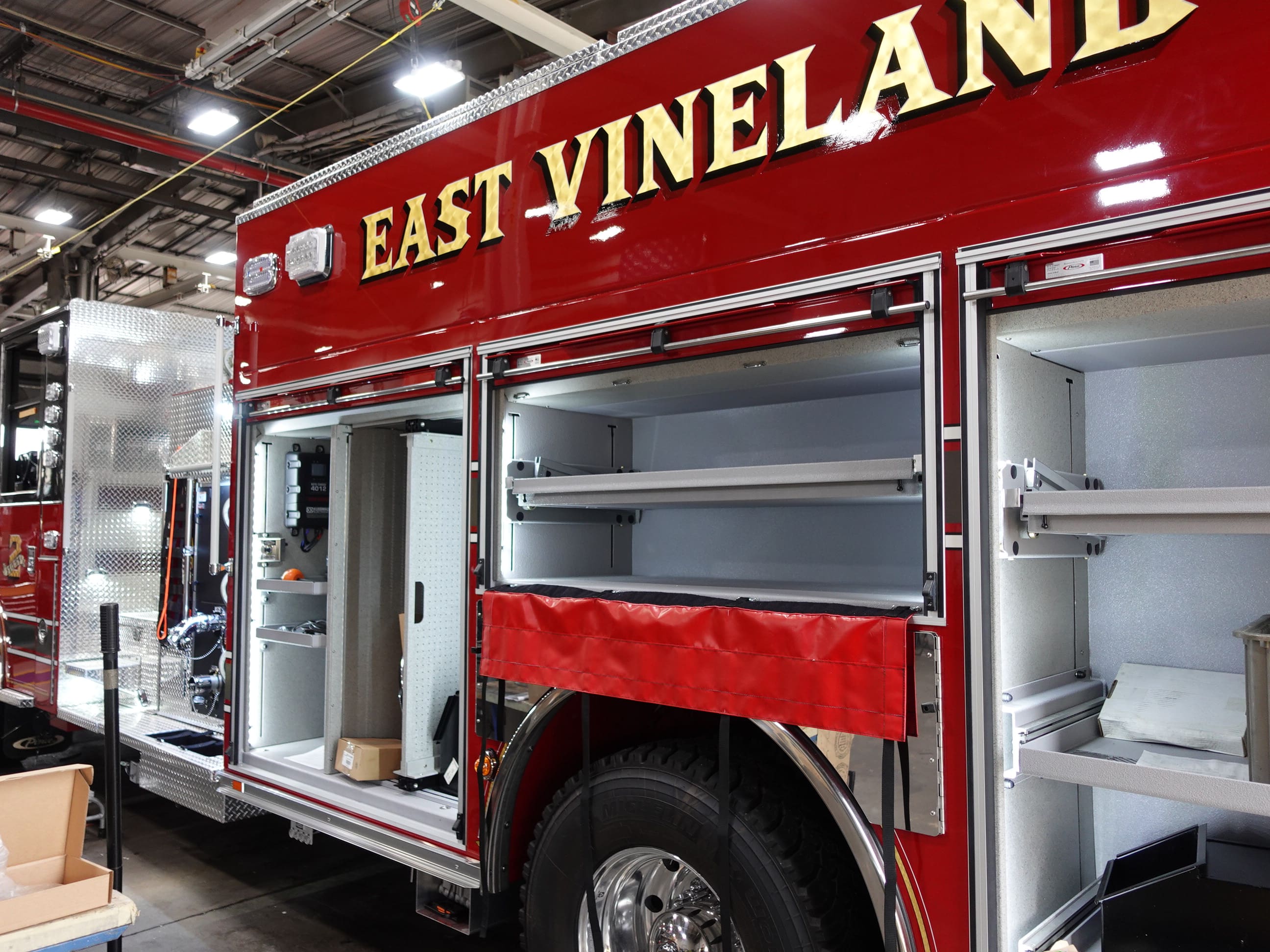

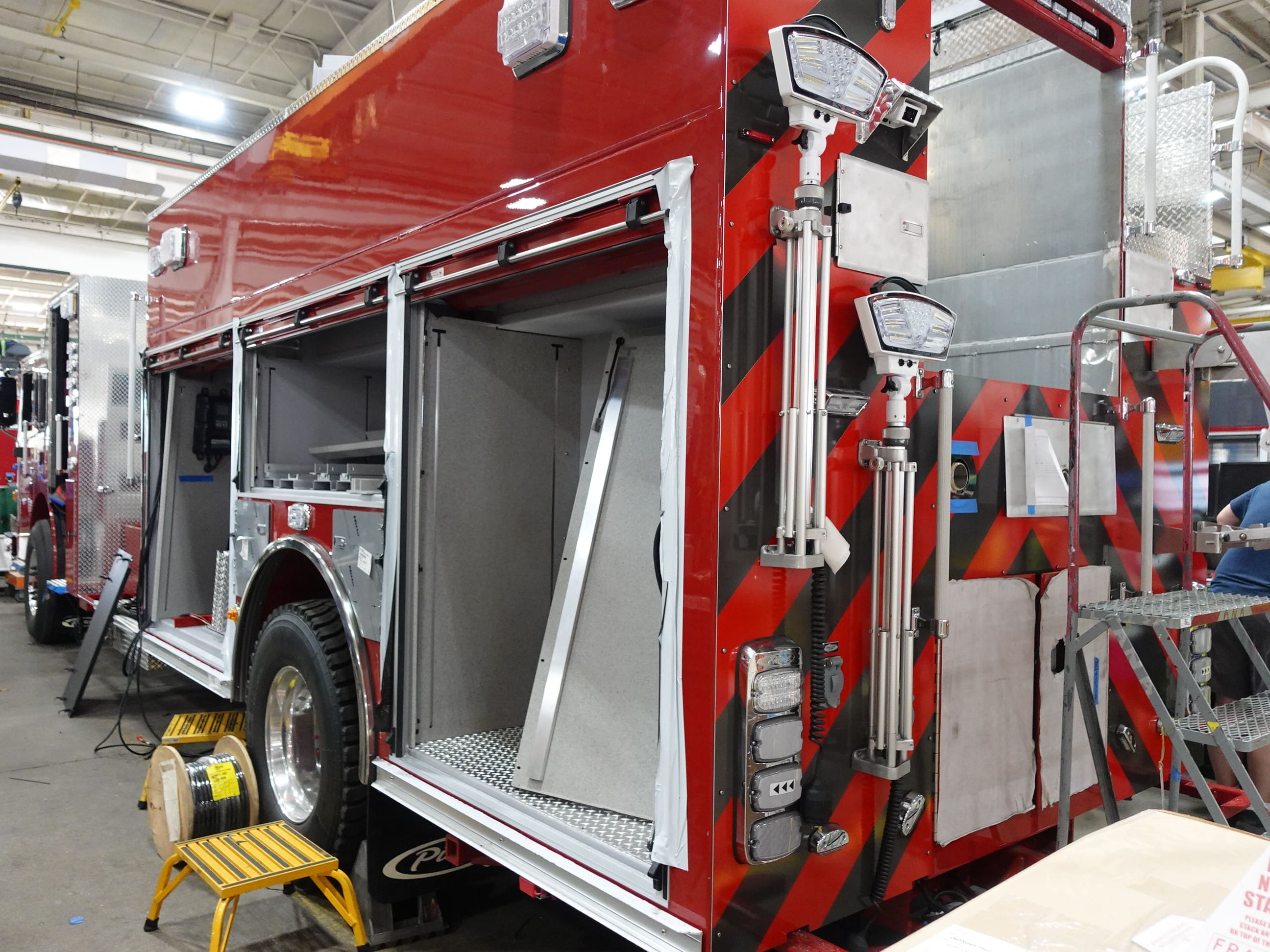

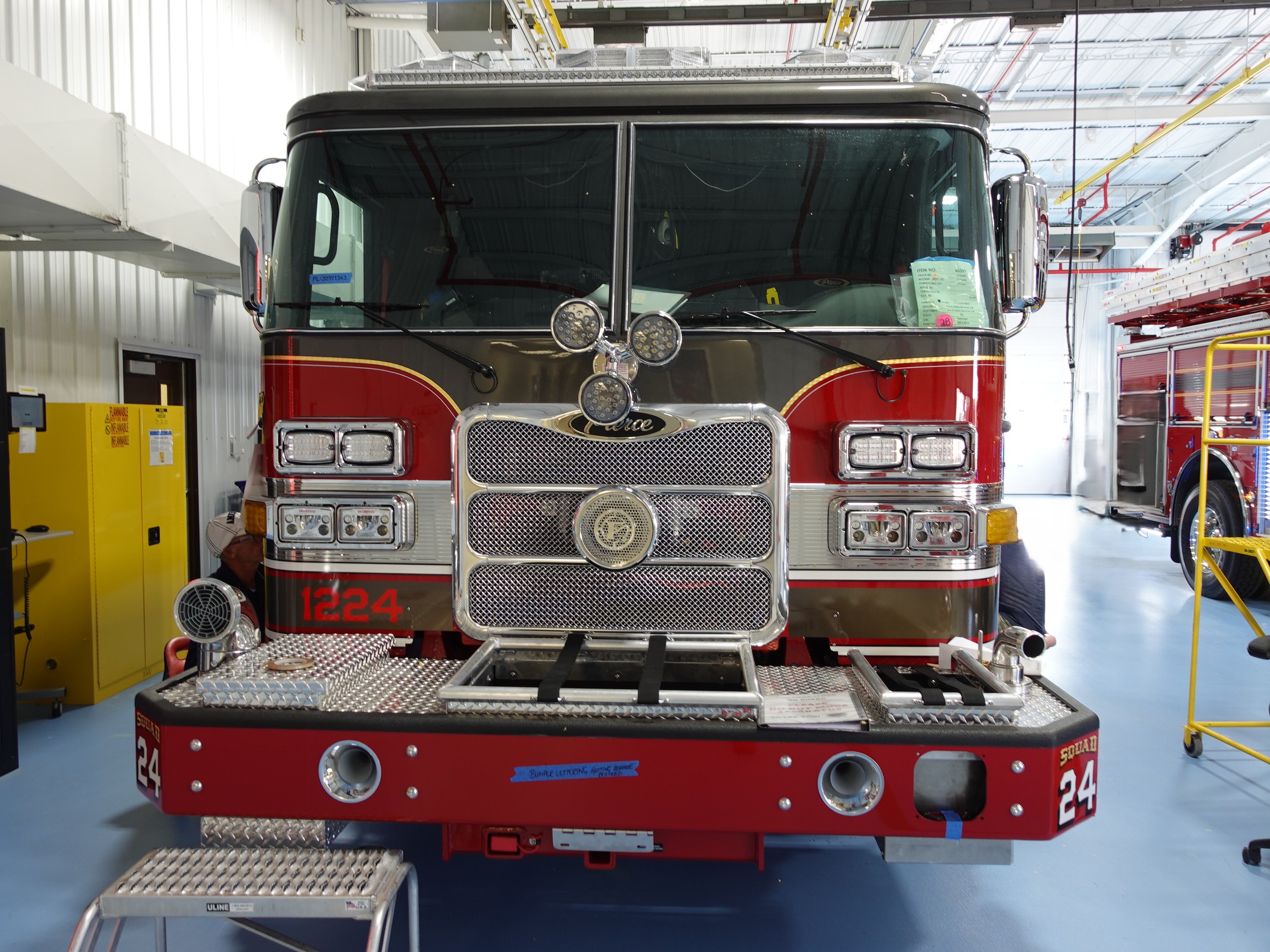

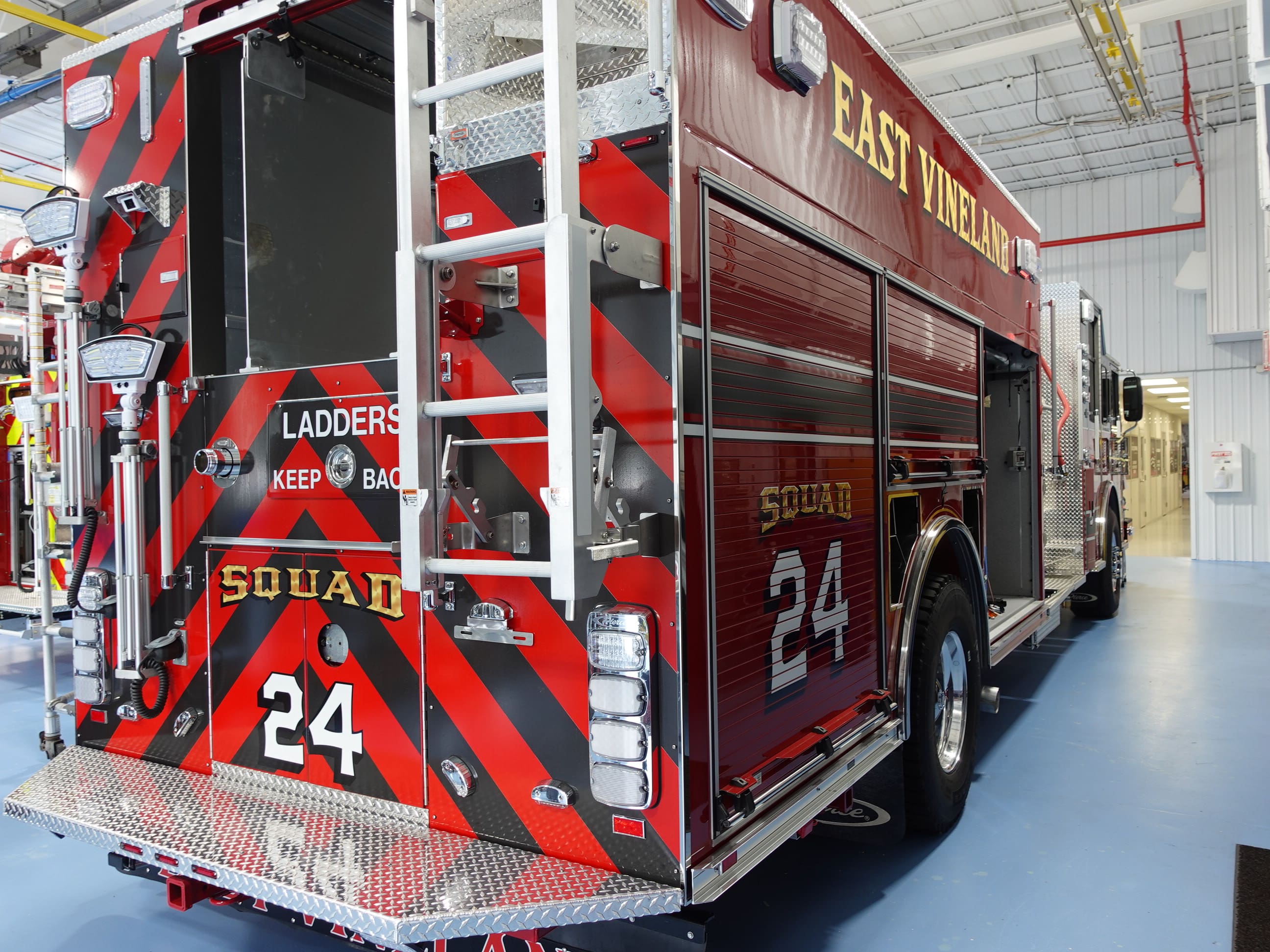

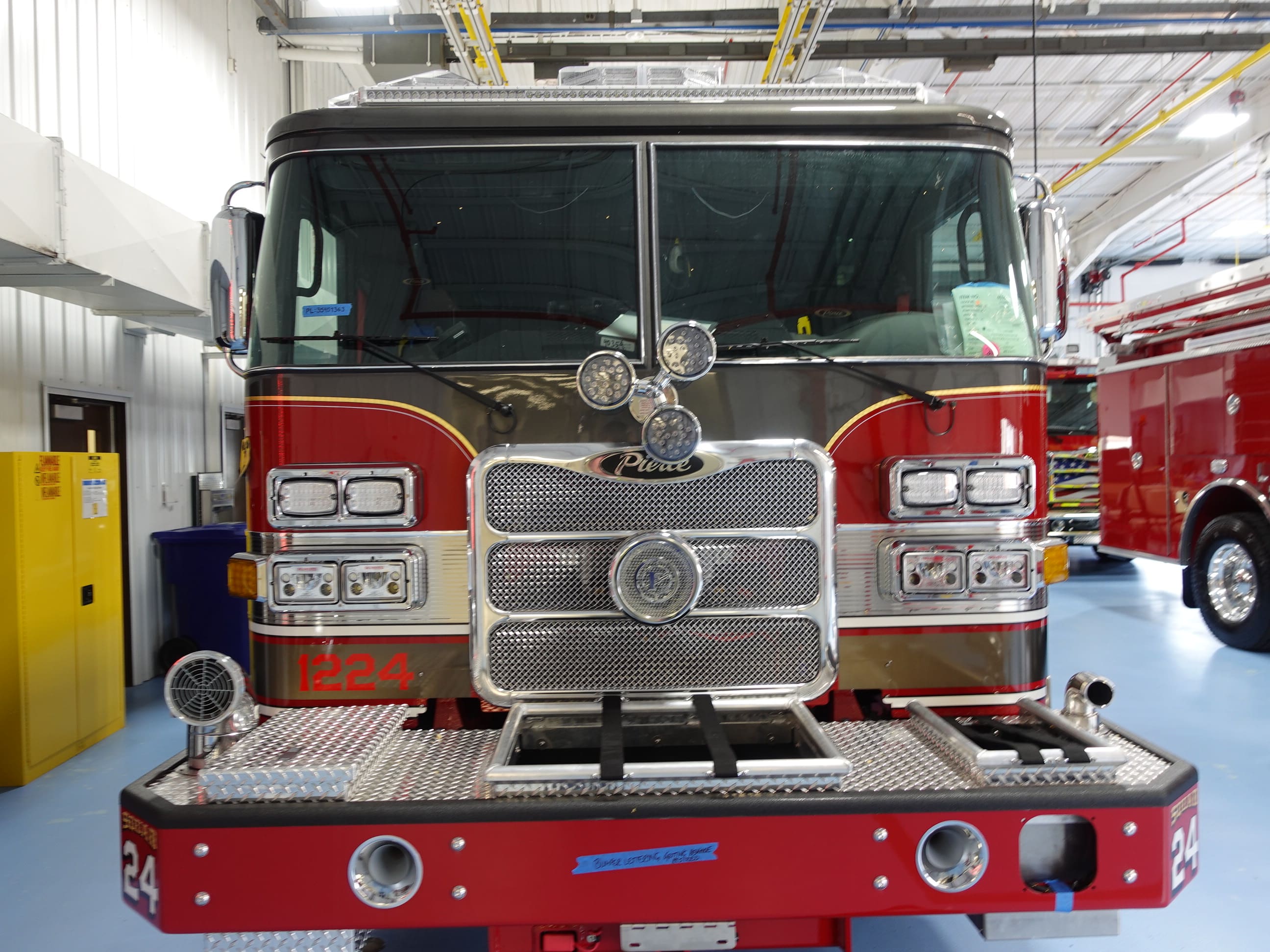

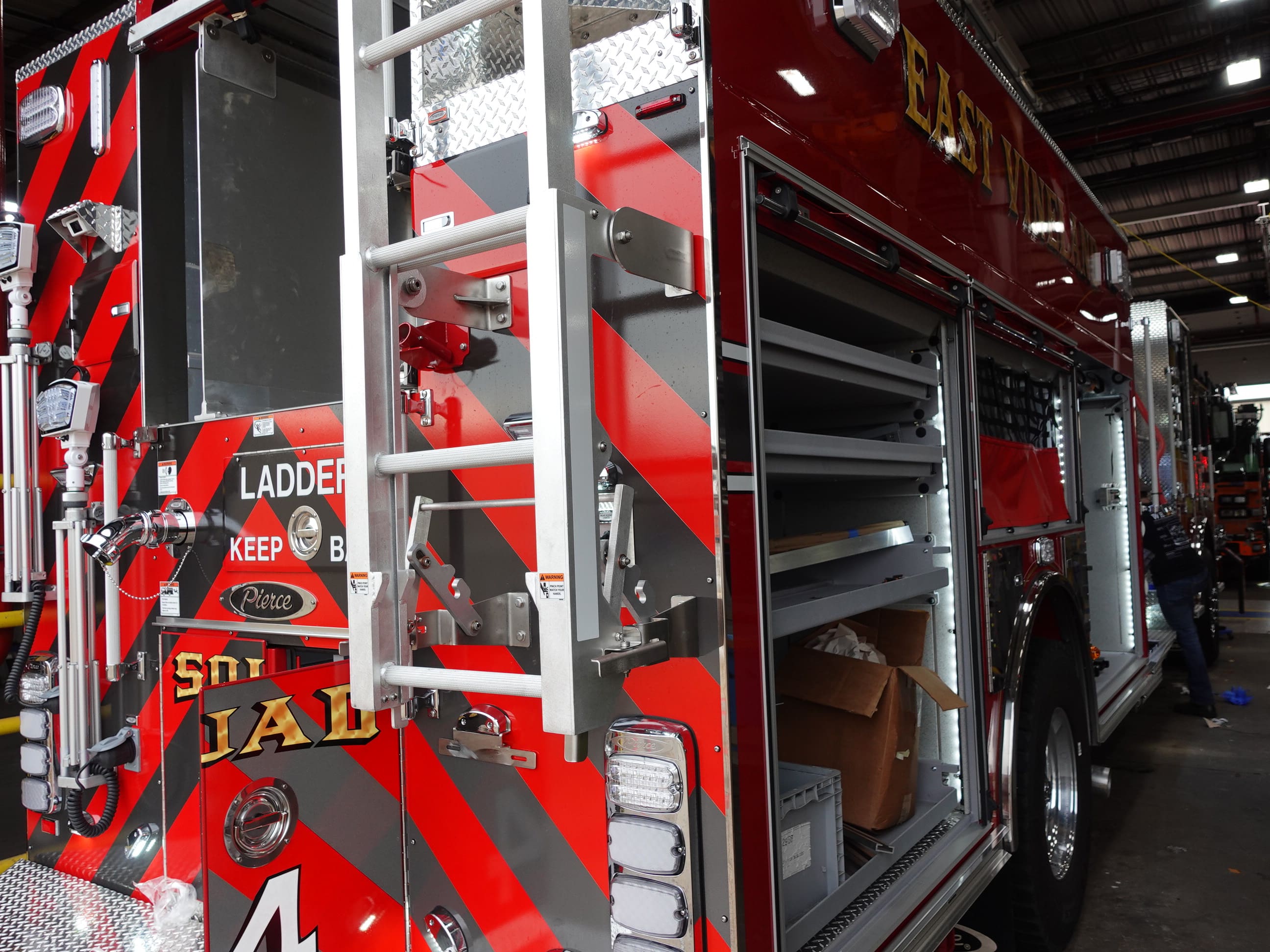

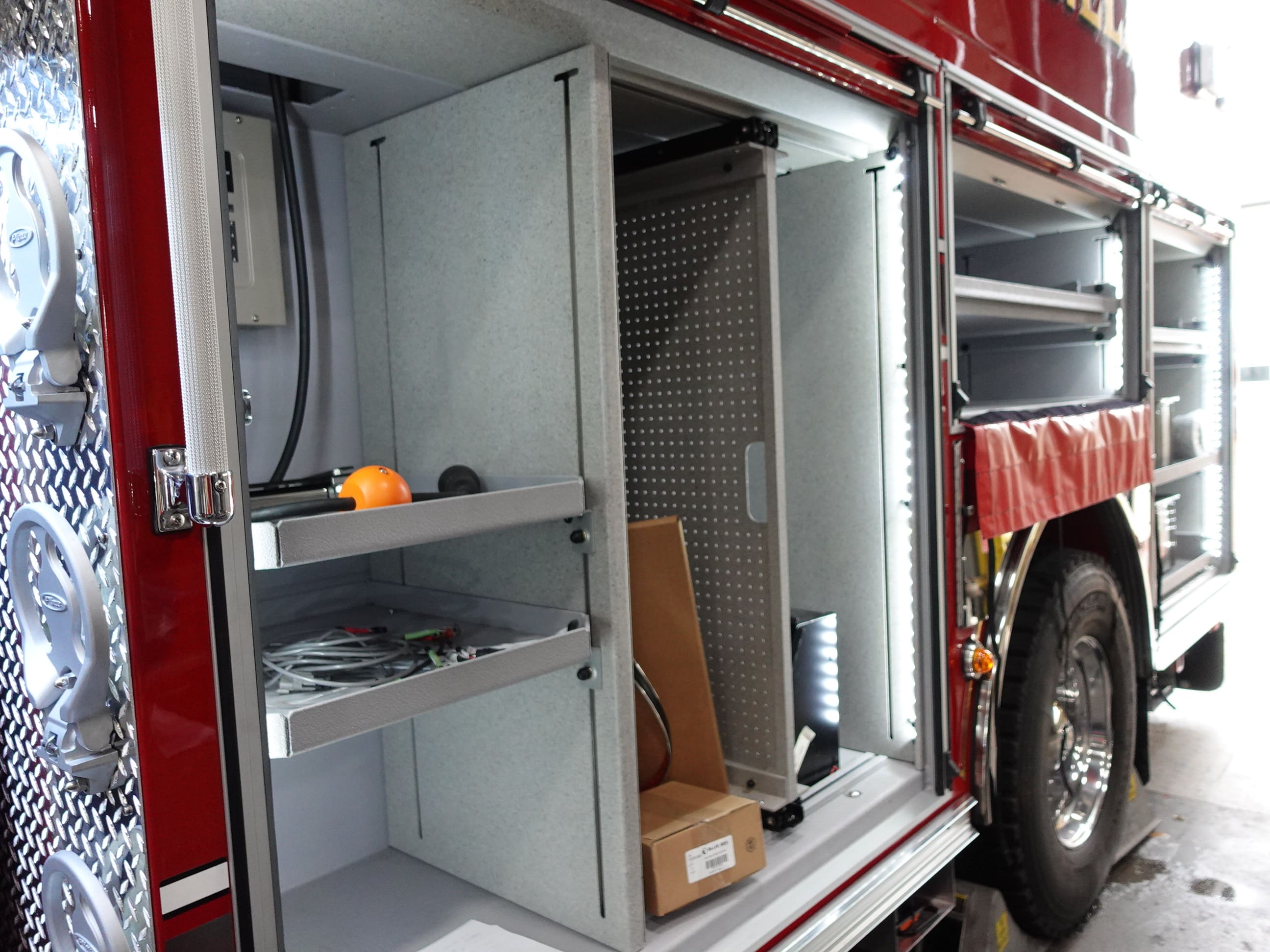

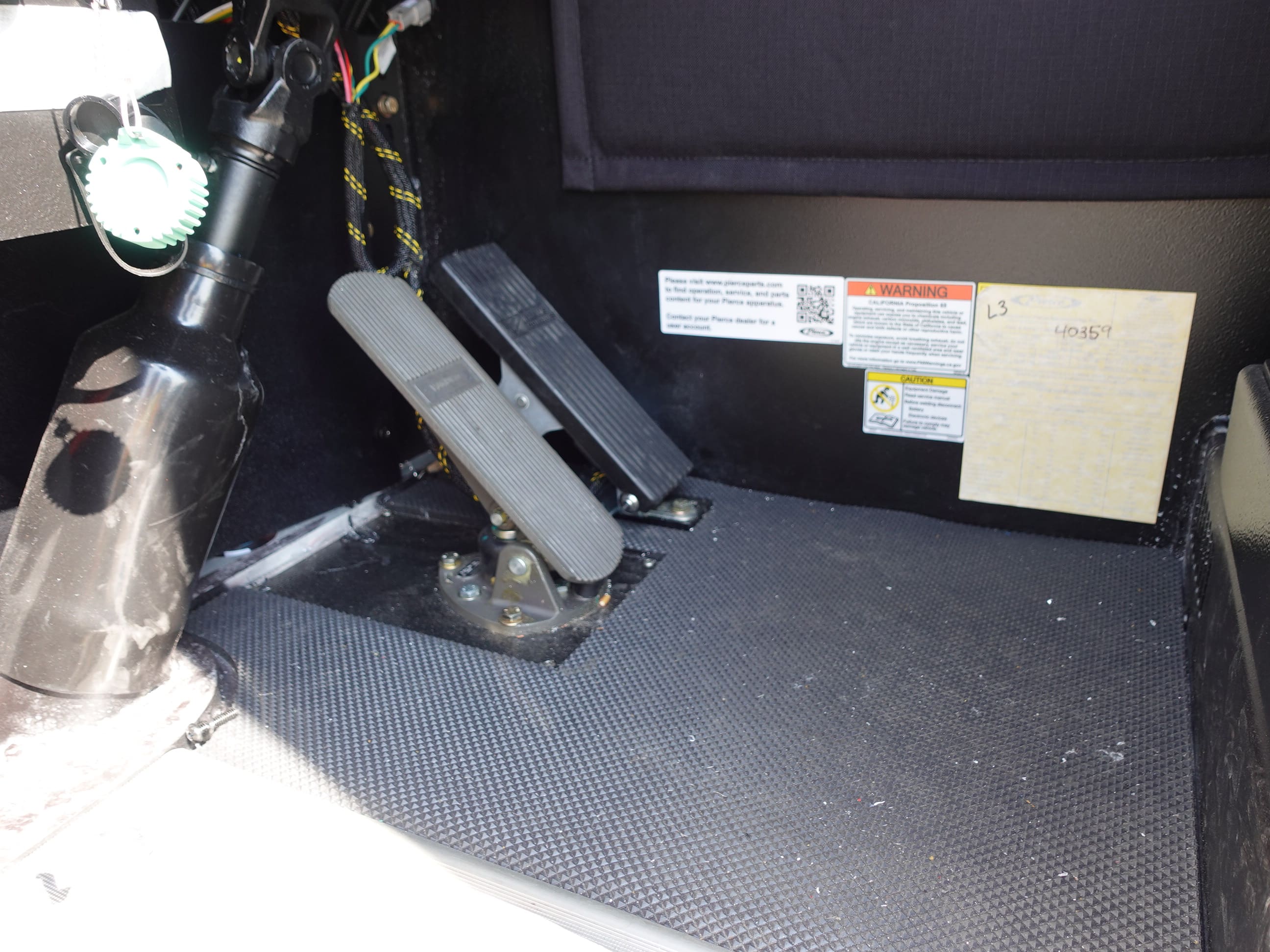

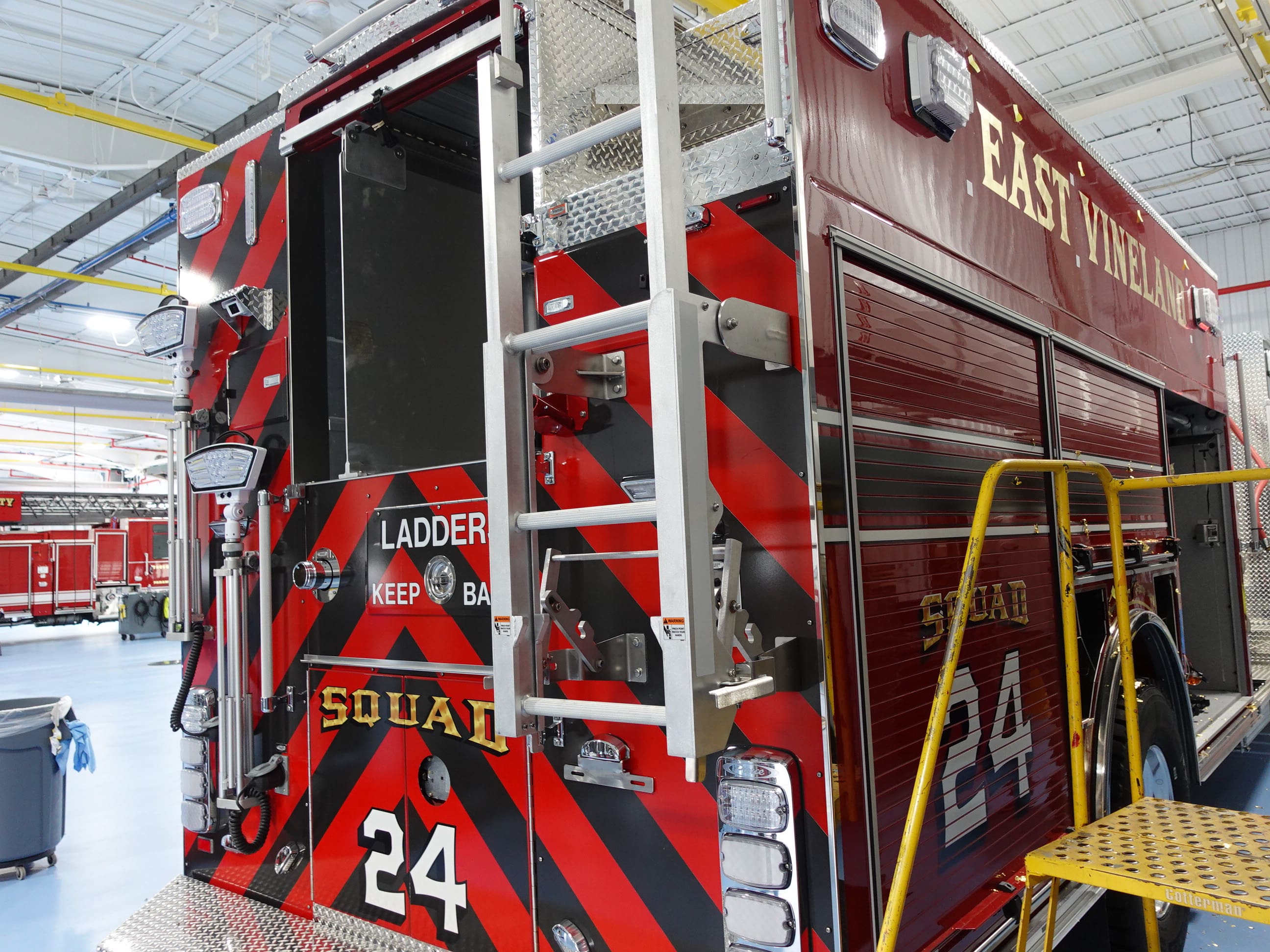

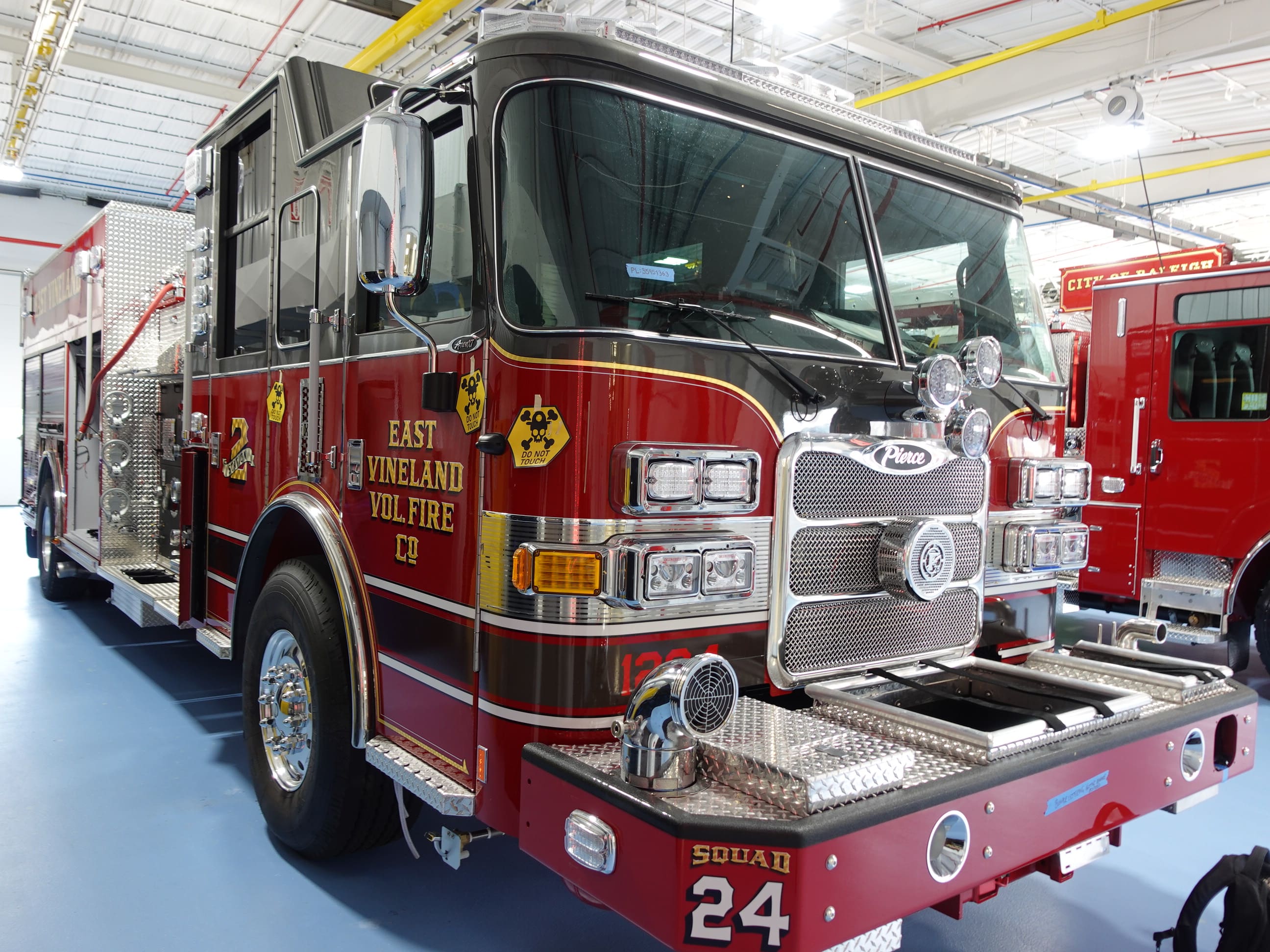

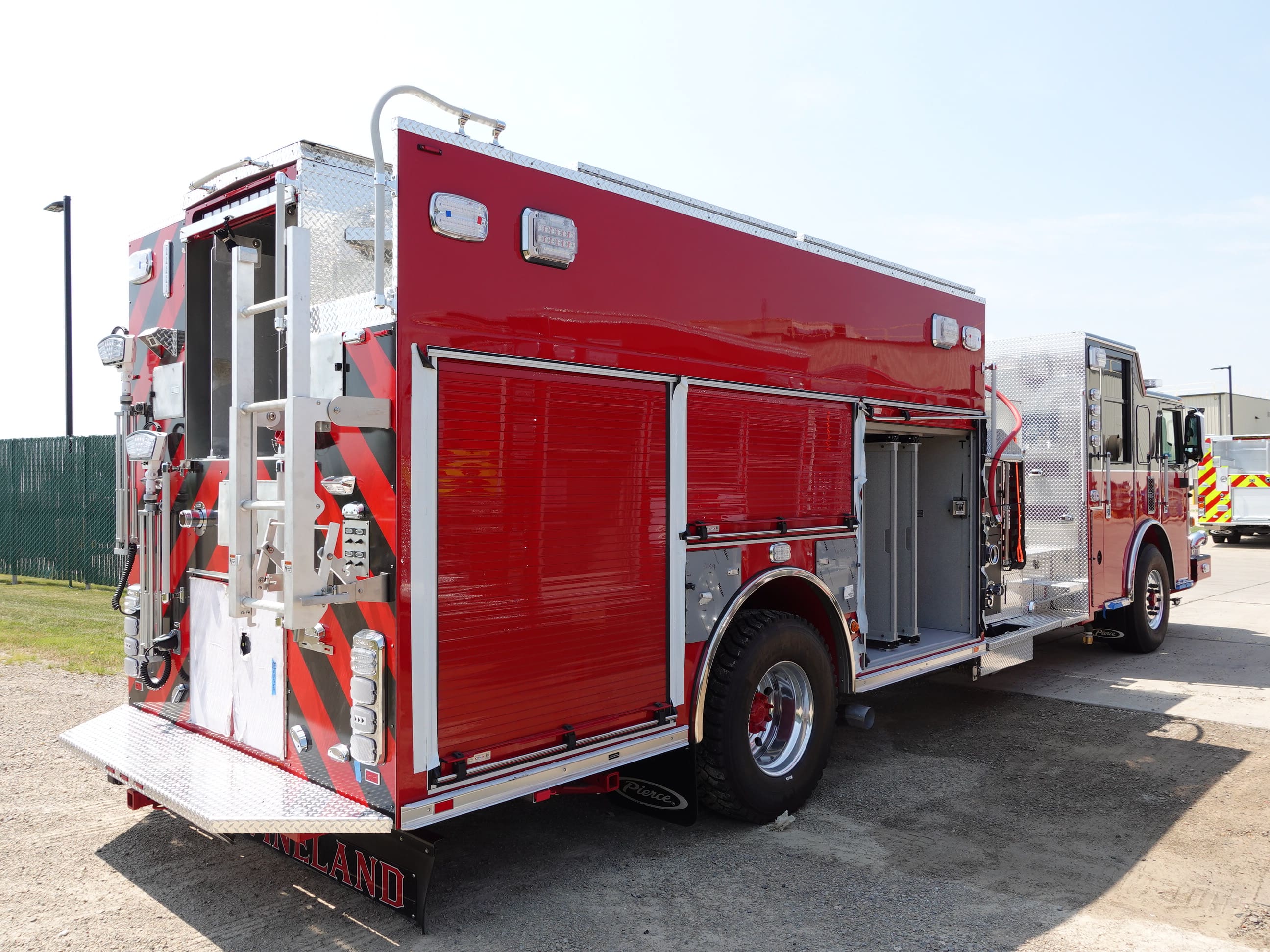

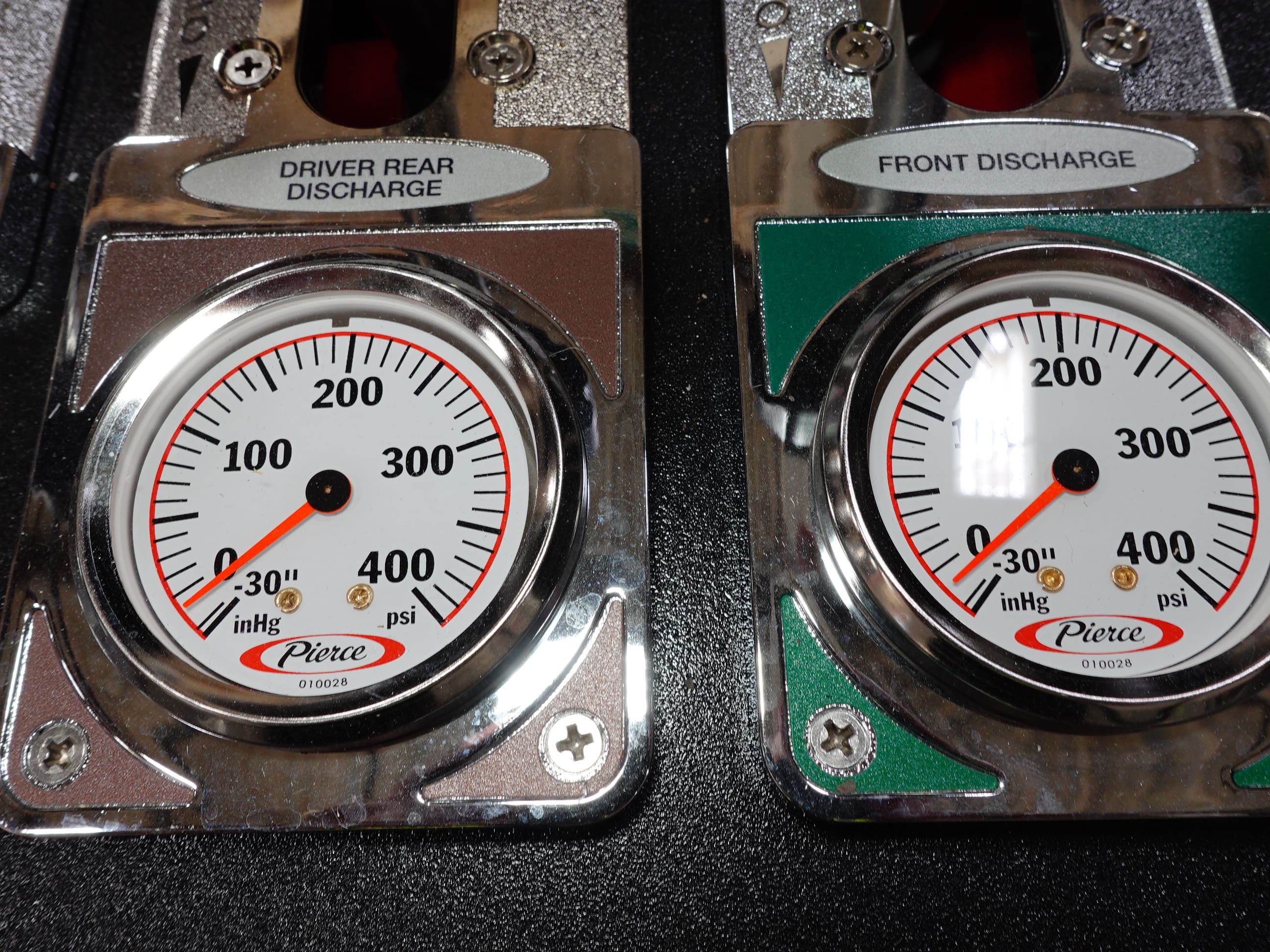

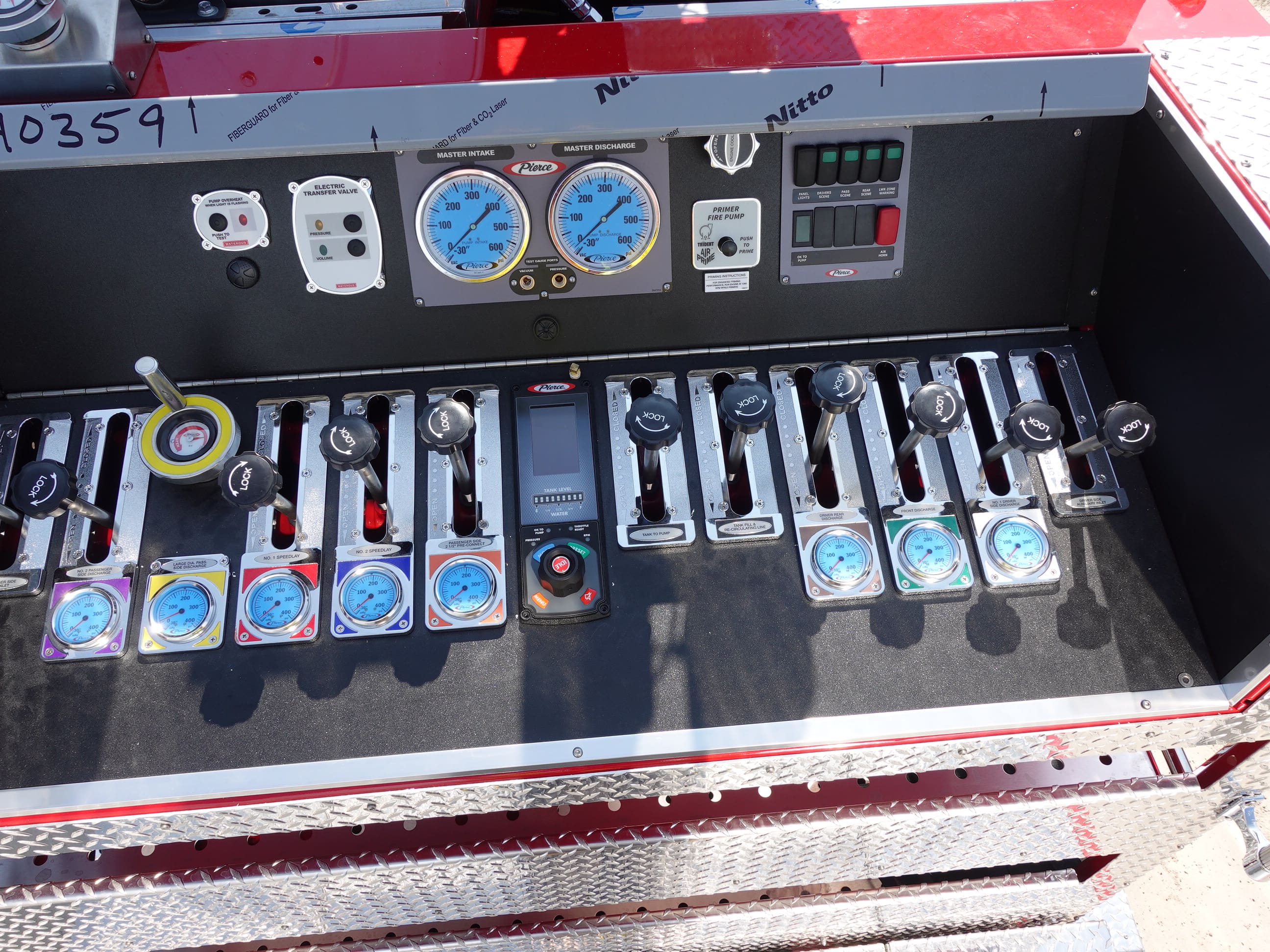

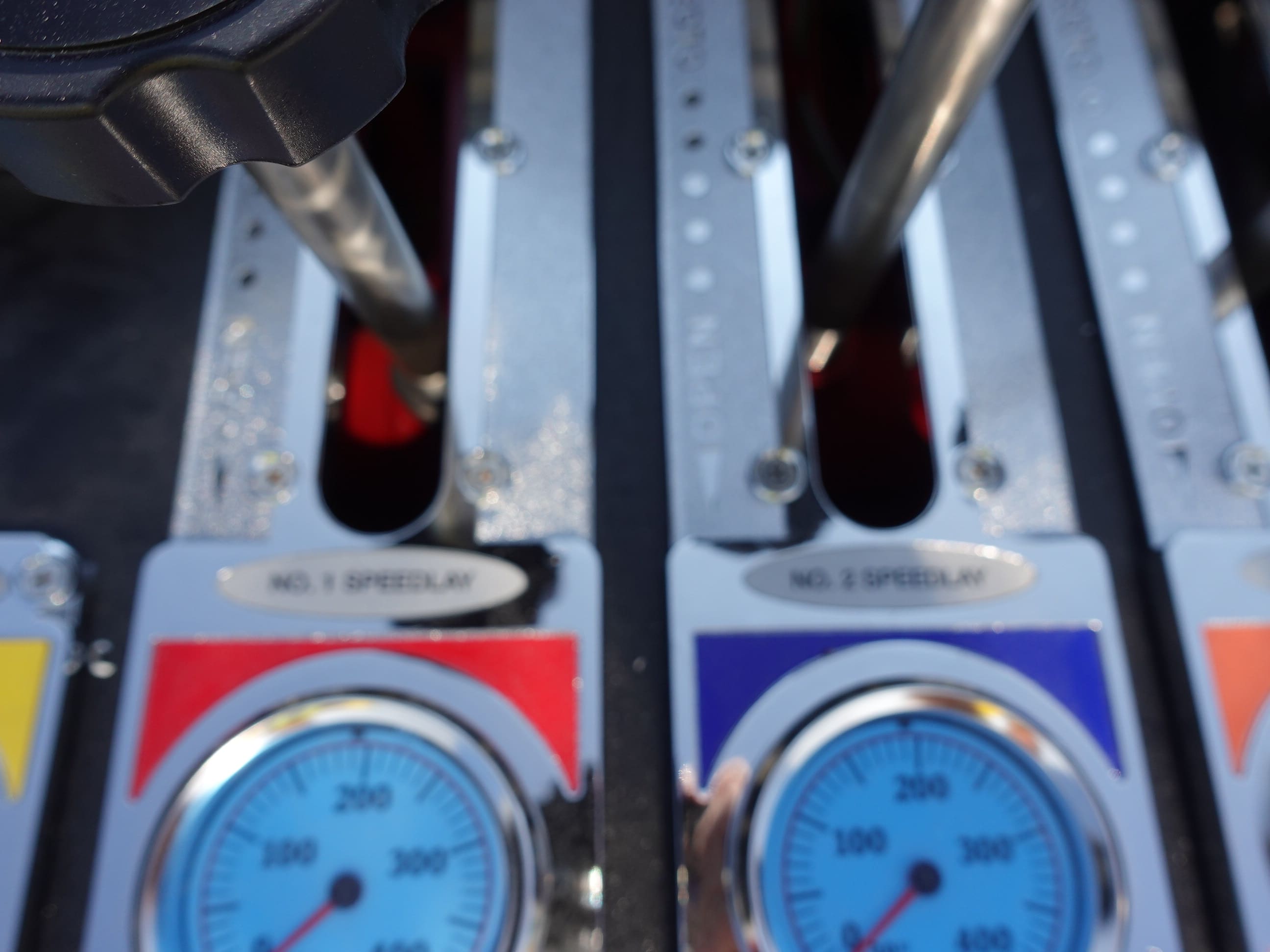

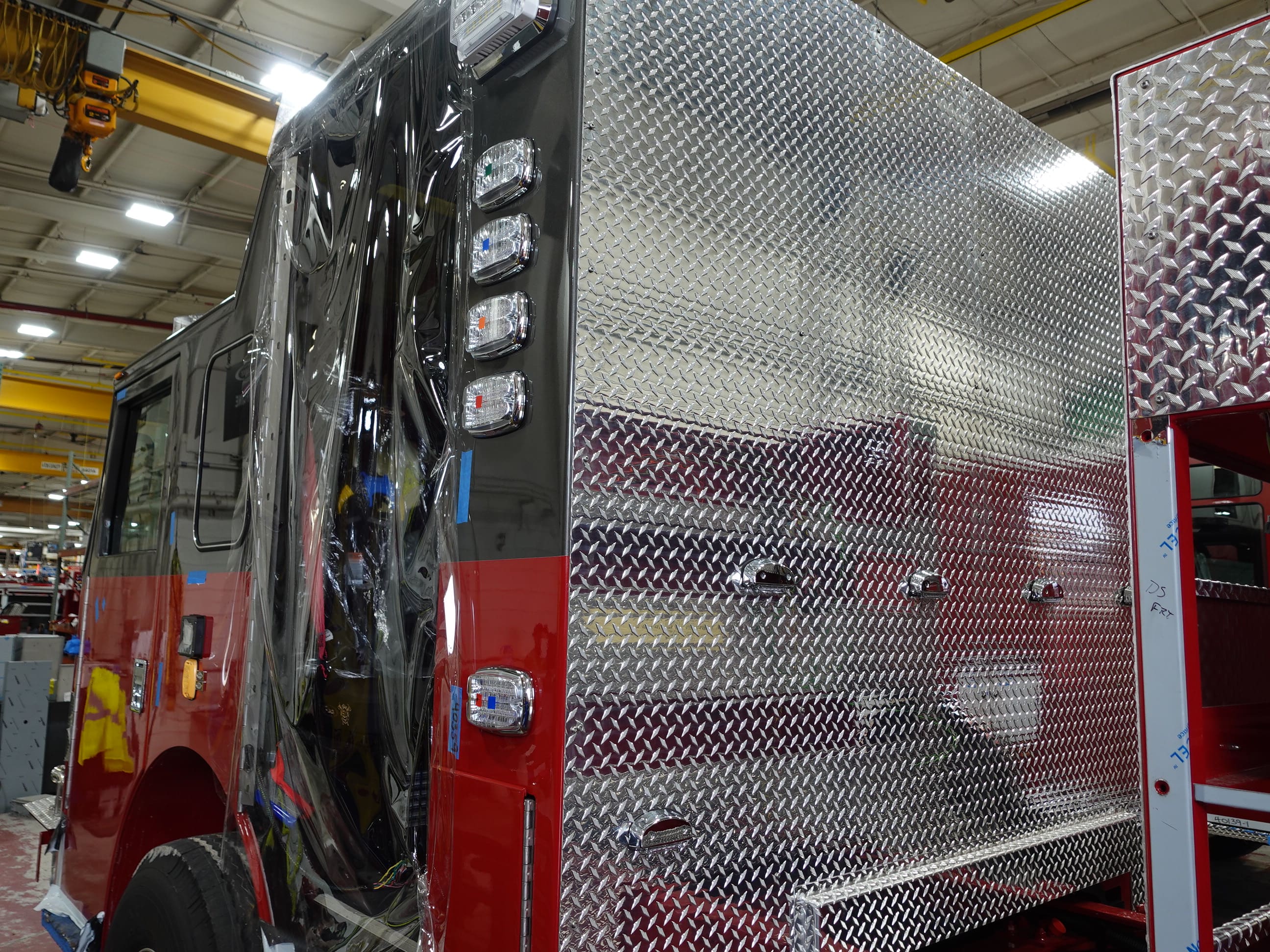

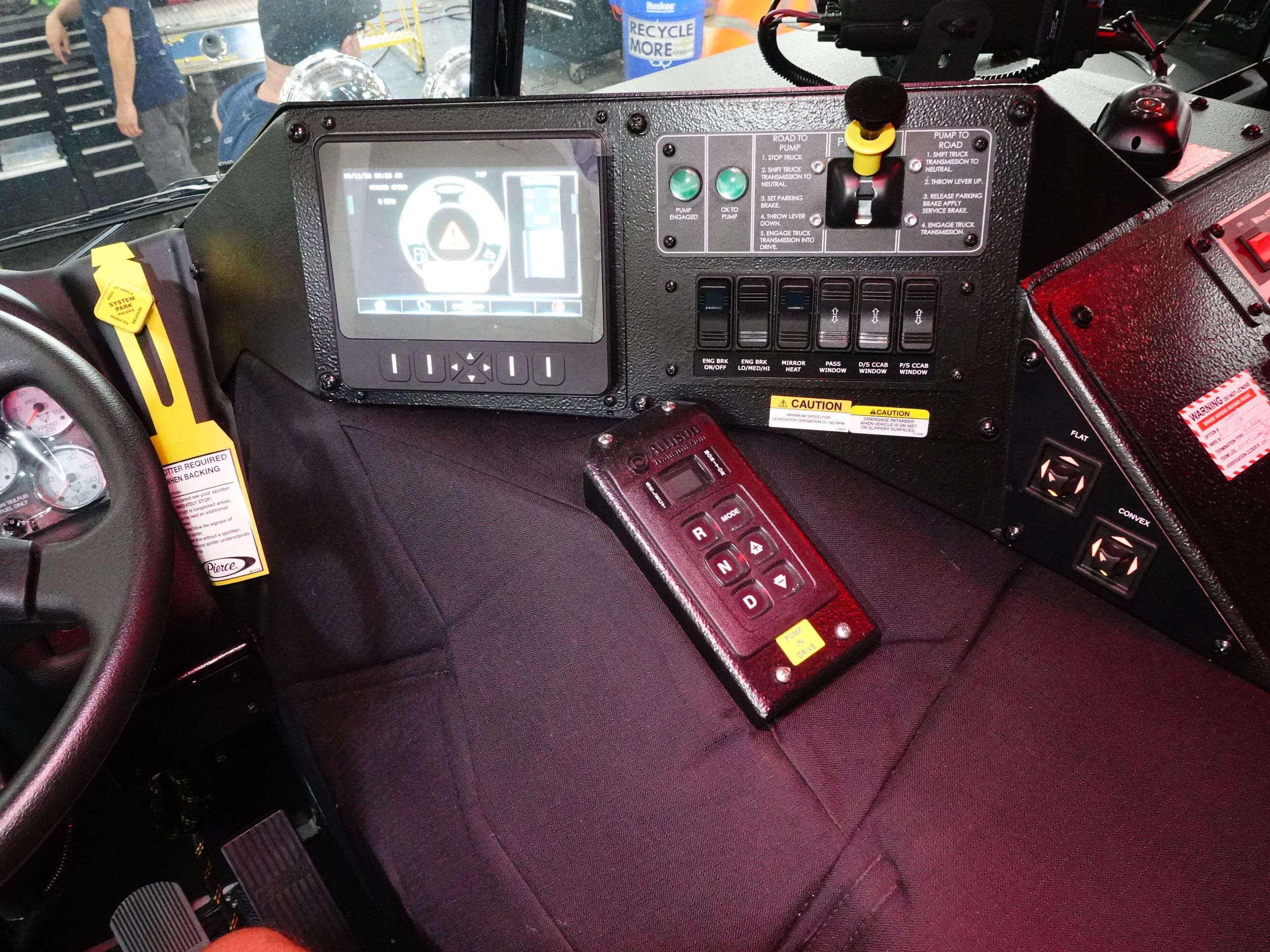

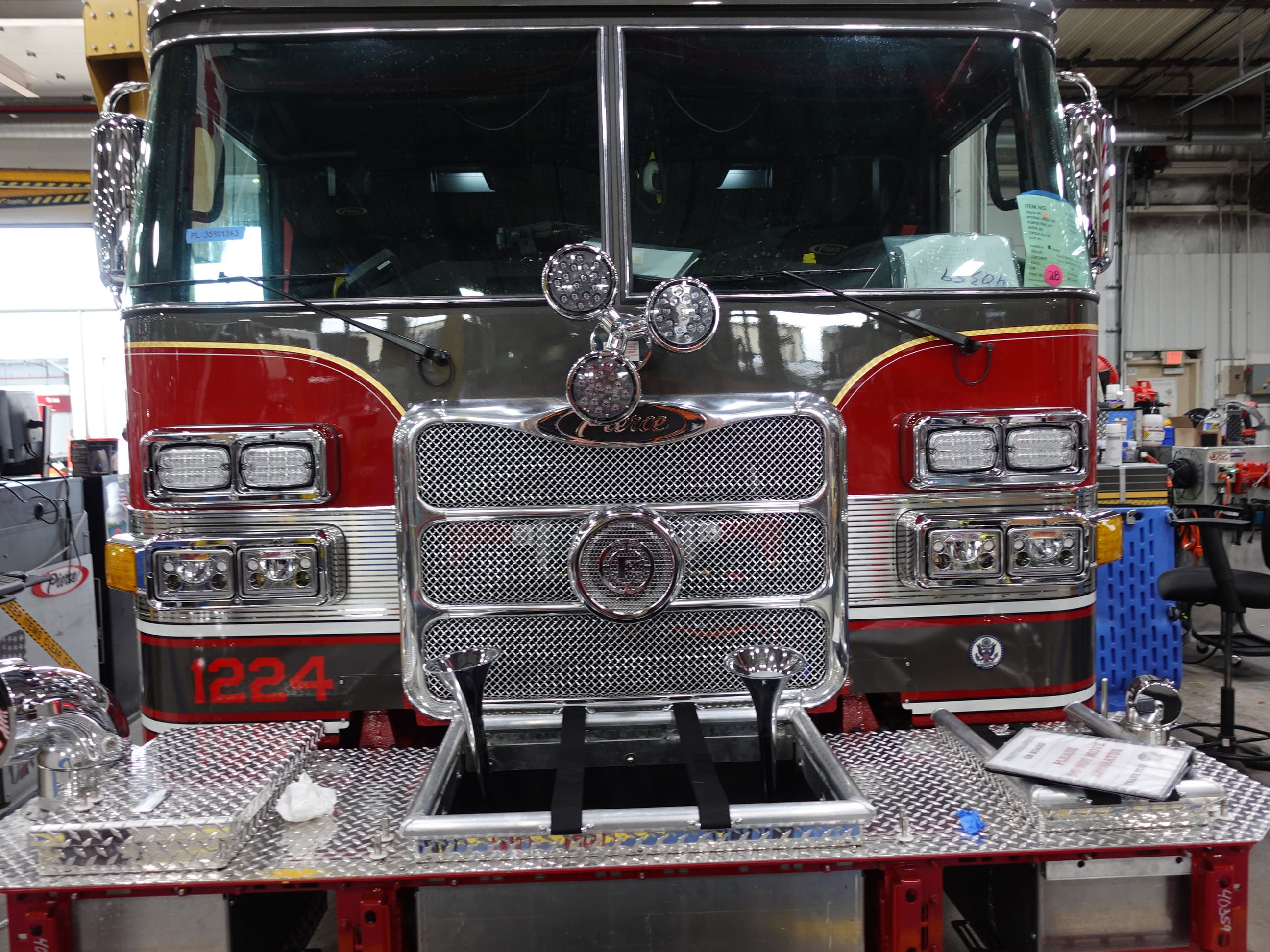

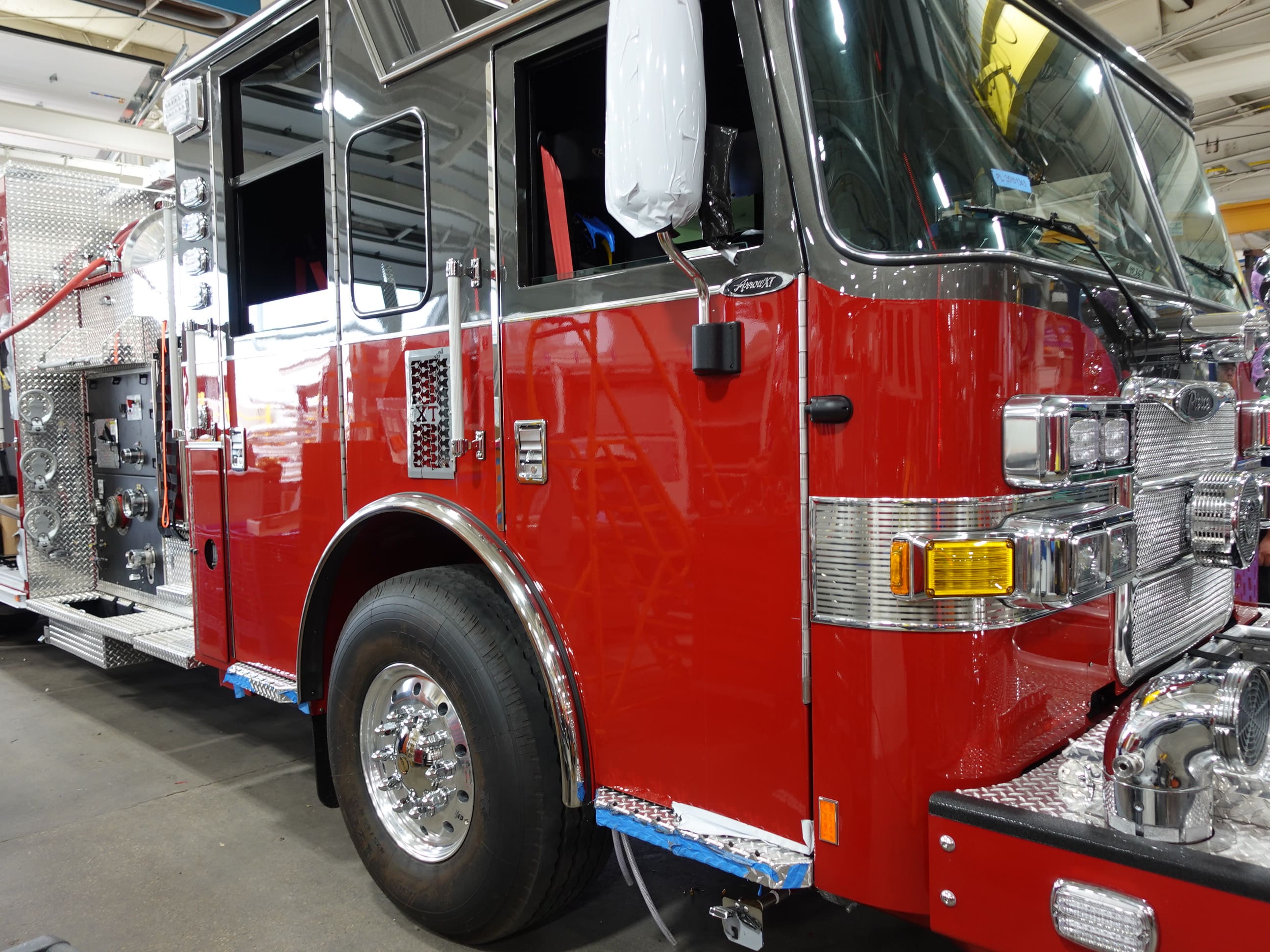

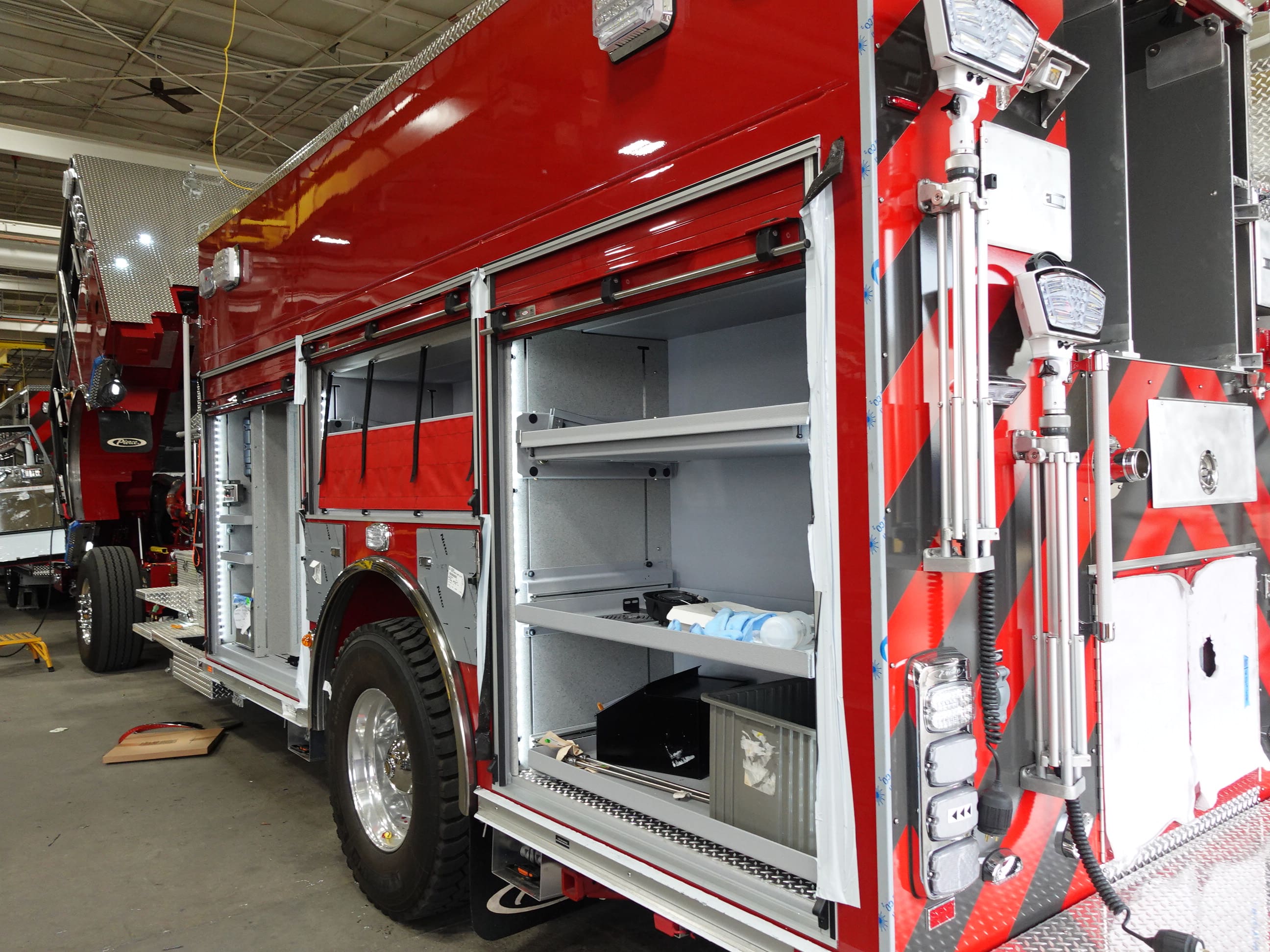

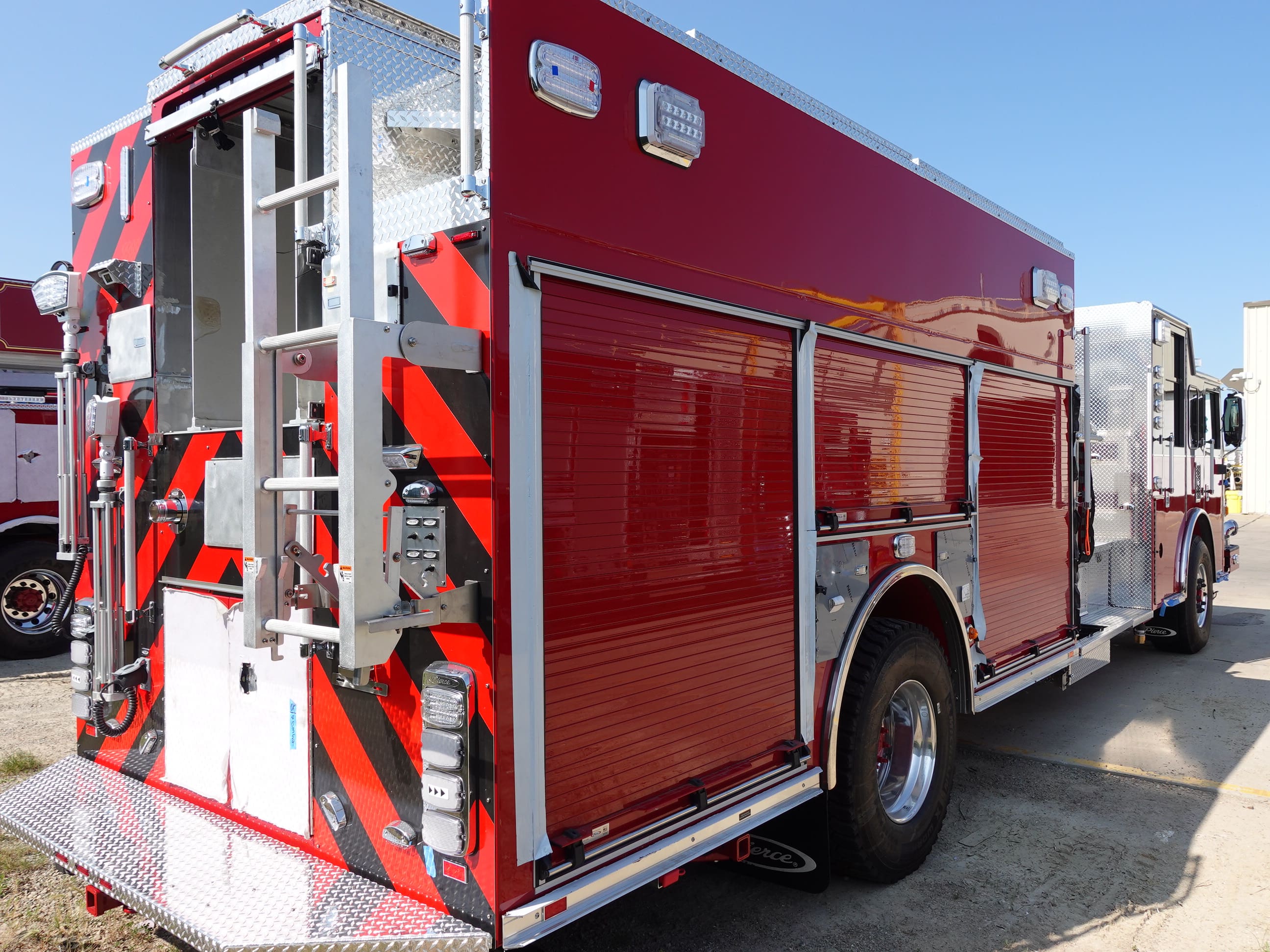

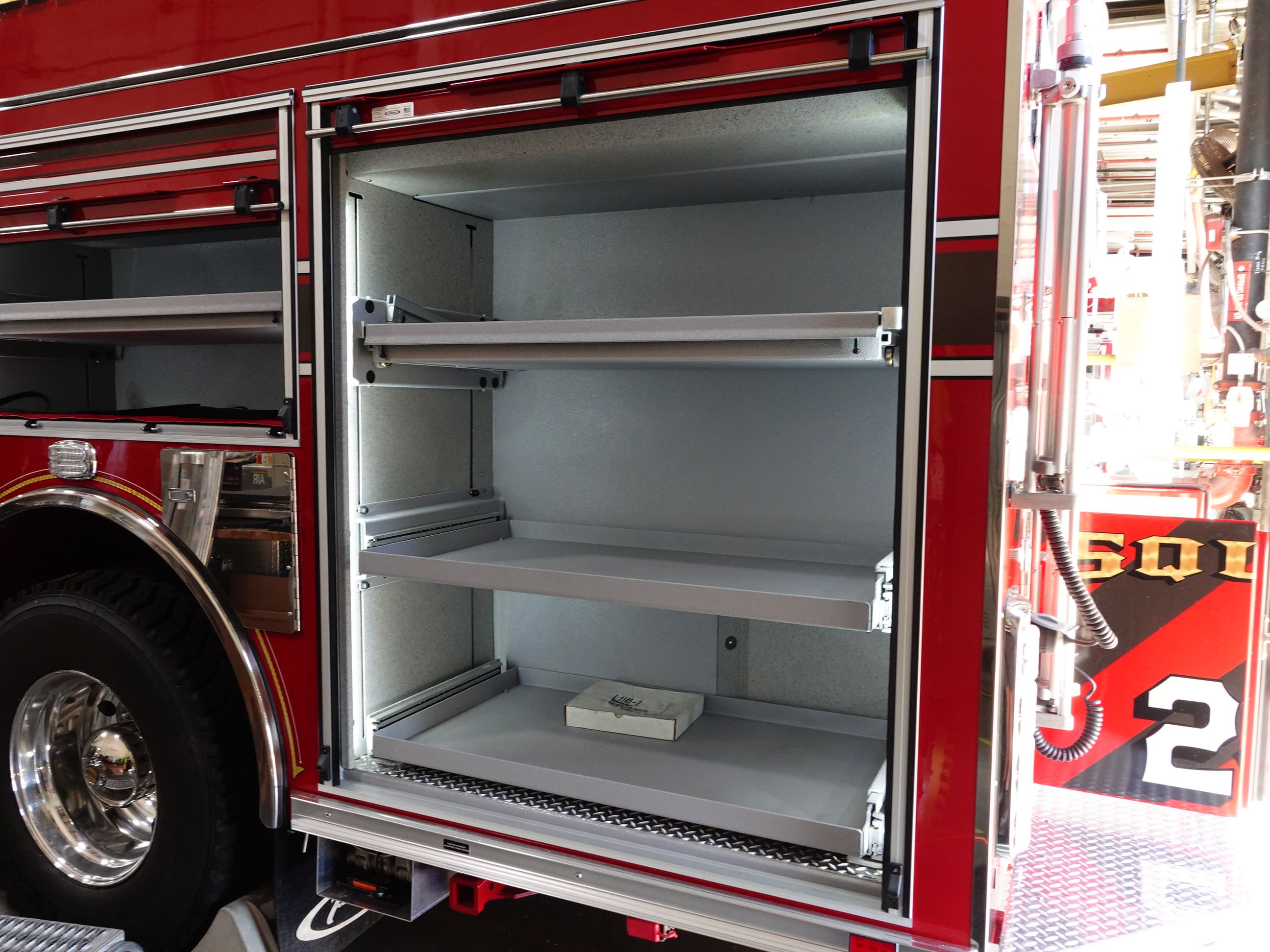

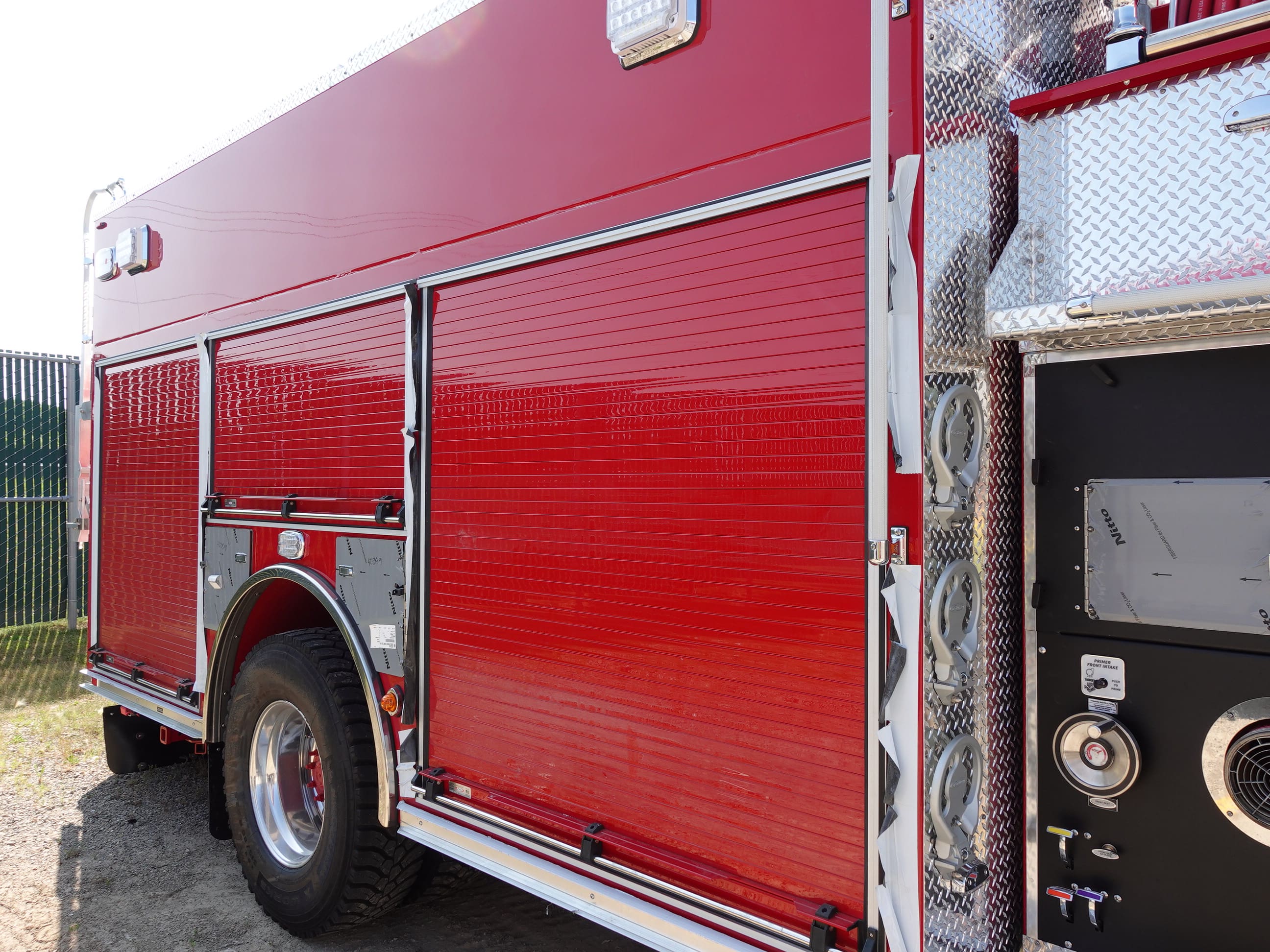

Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.

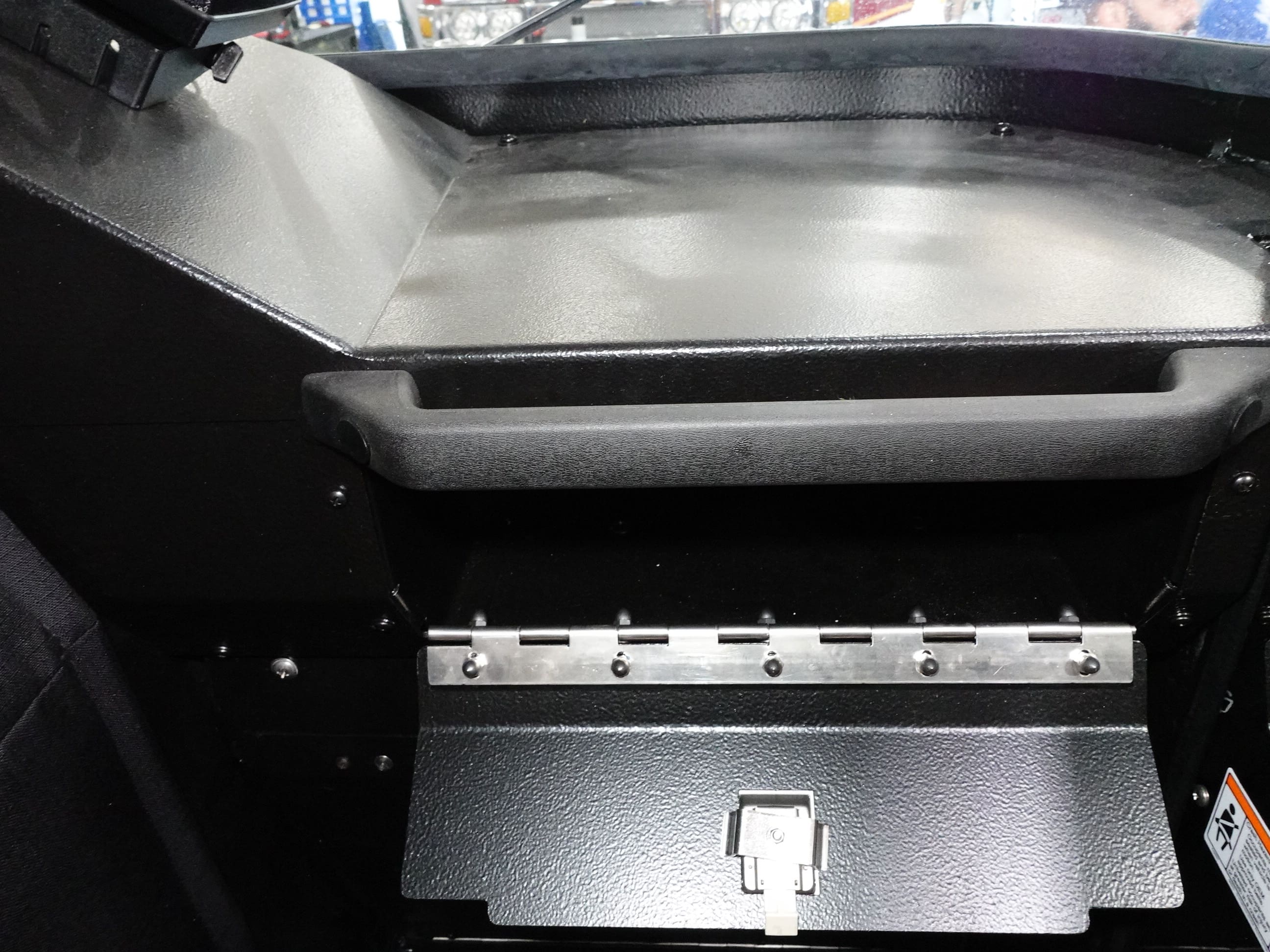

09-04-26

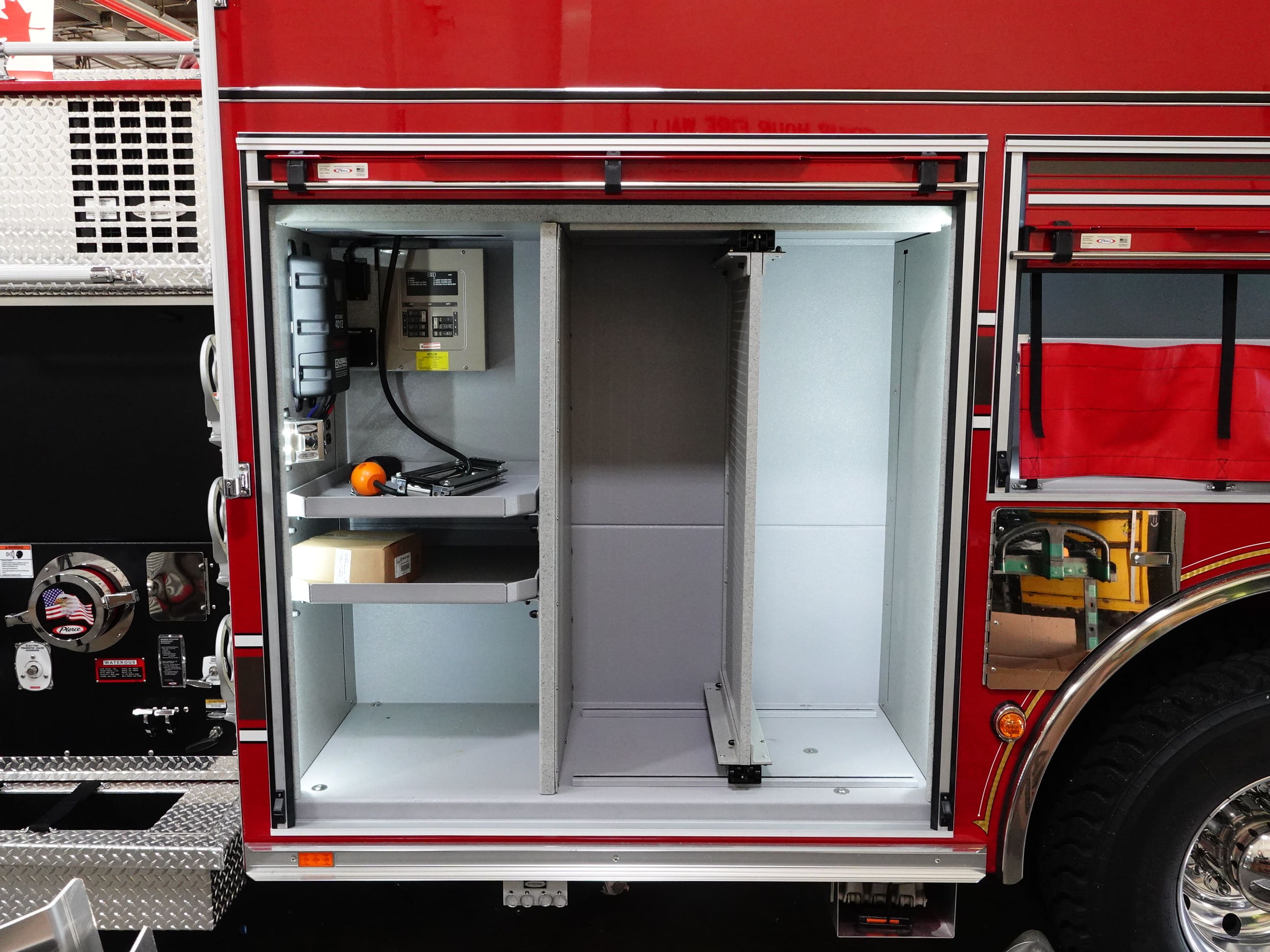

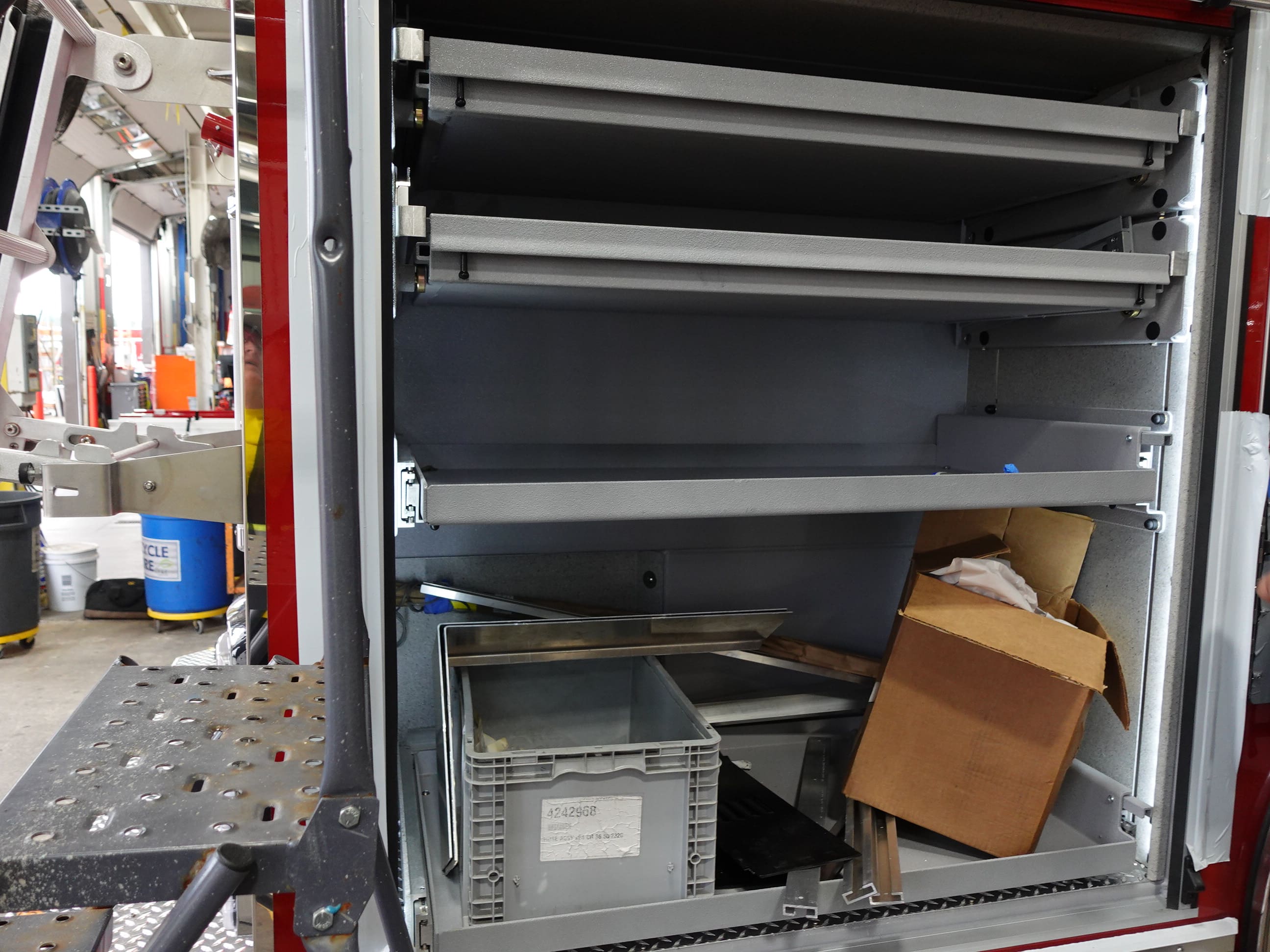

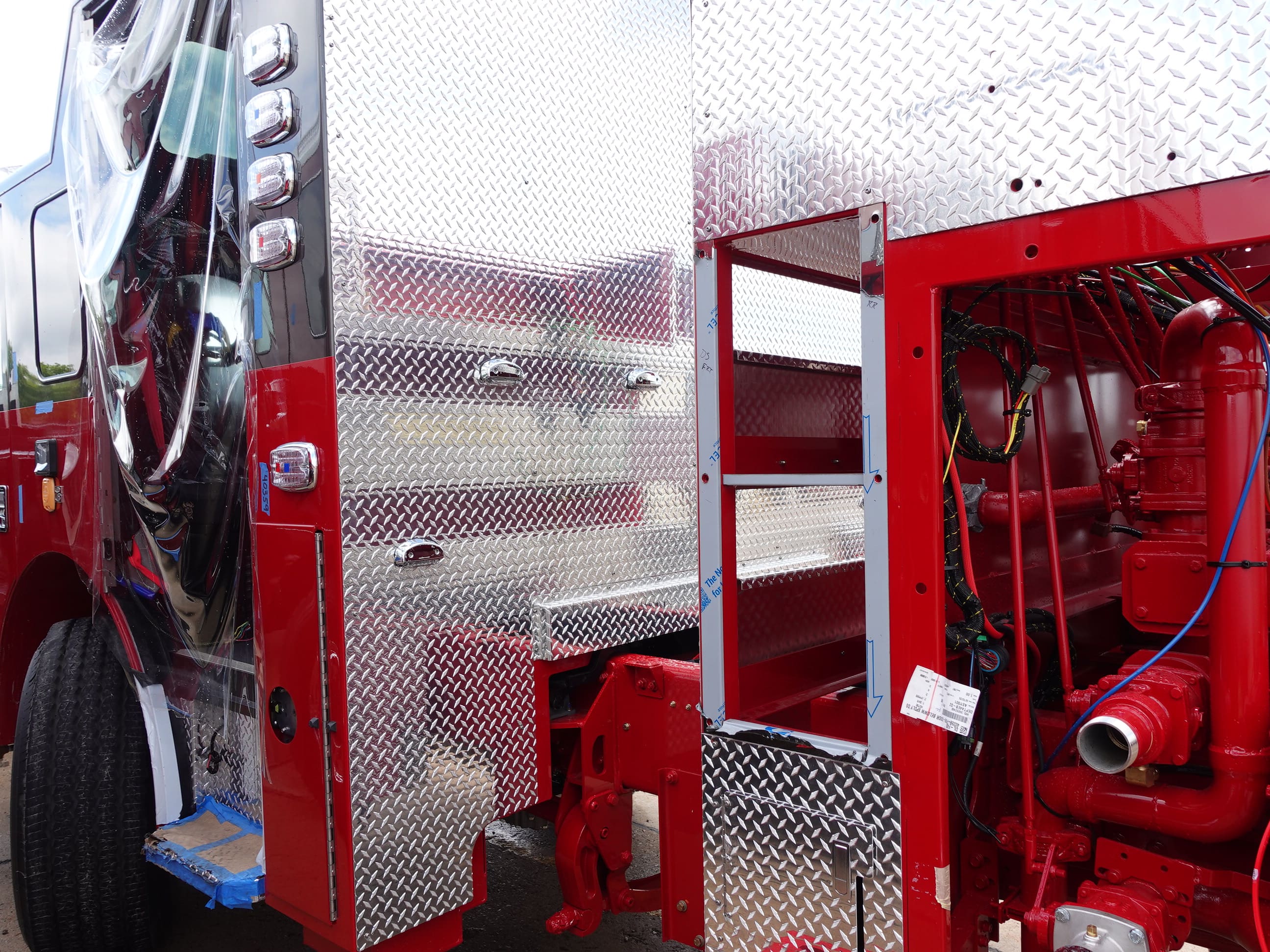

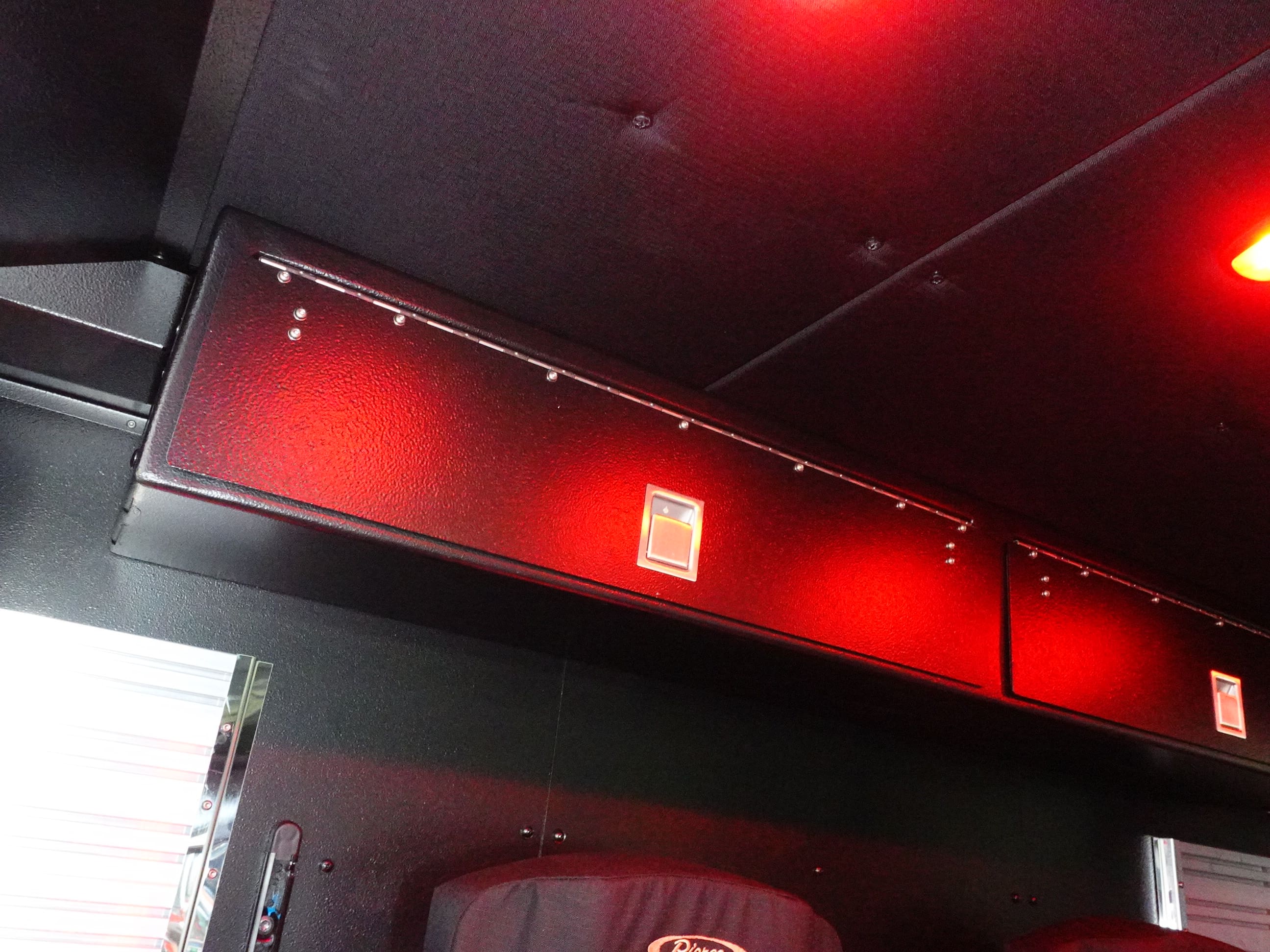

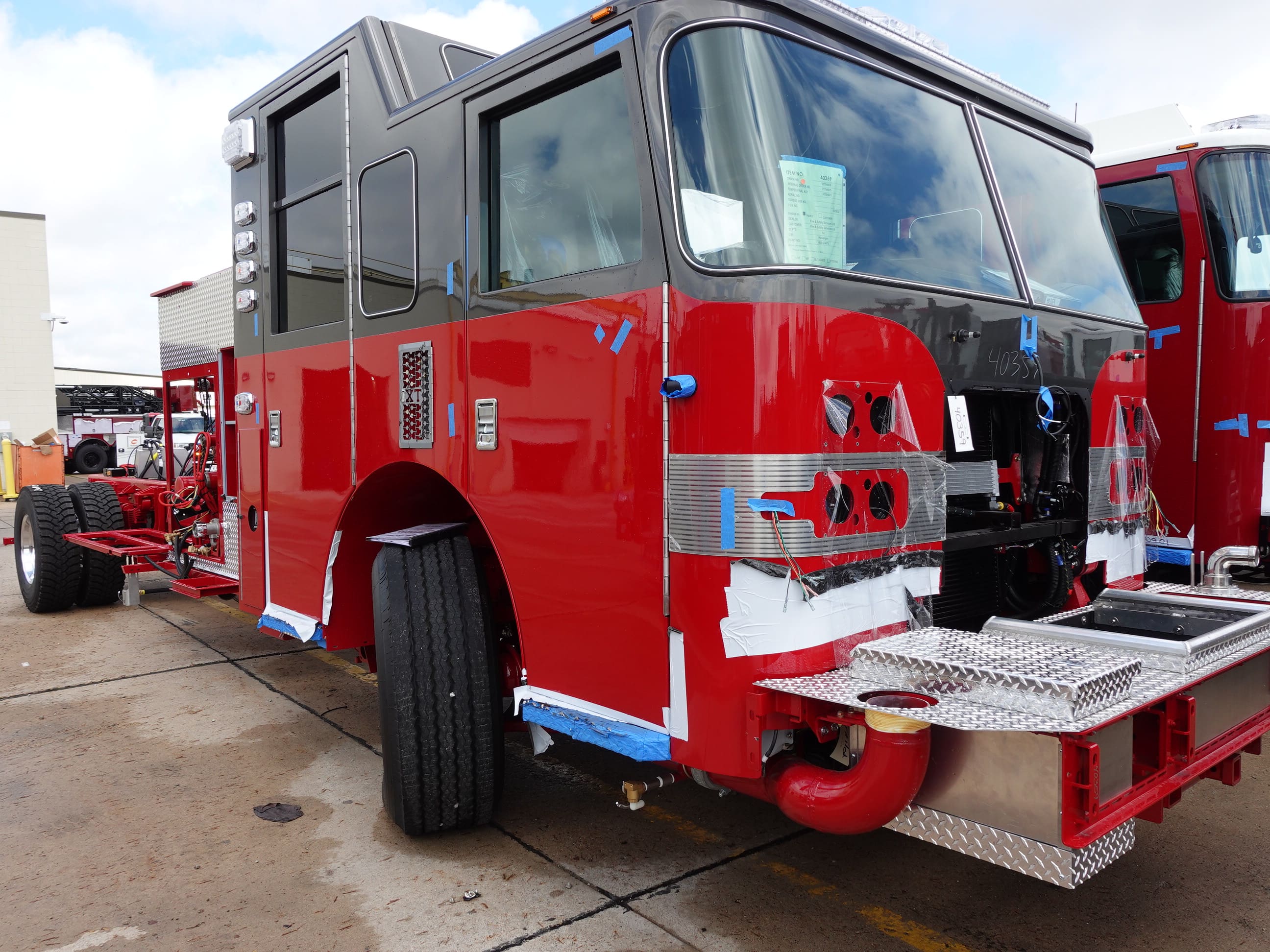

In this report, graphics application was completed and the apparatus continued the quality process

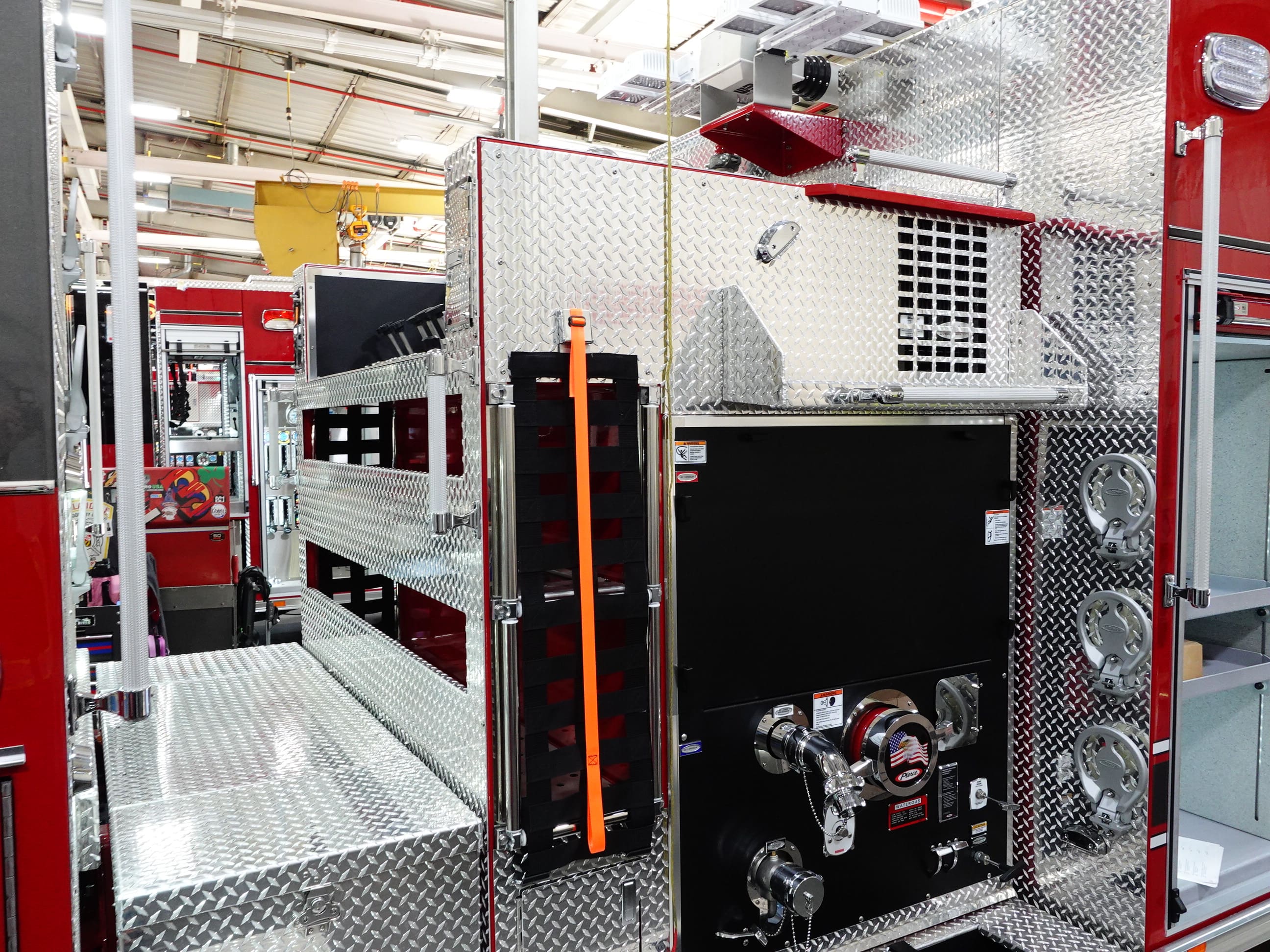

where any remaining content is applied.

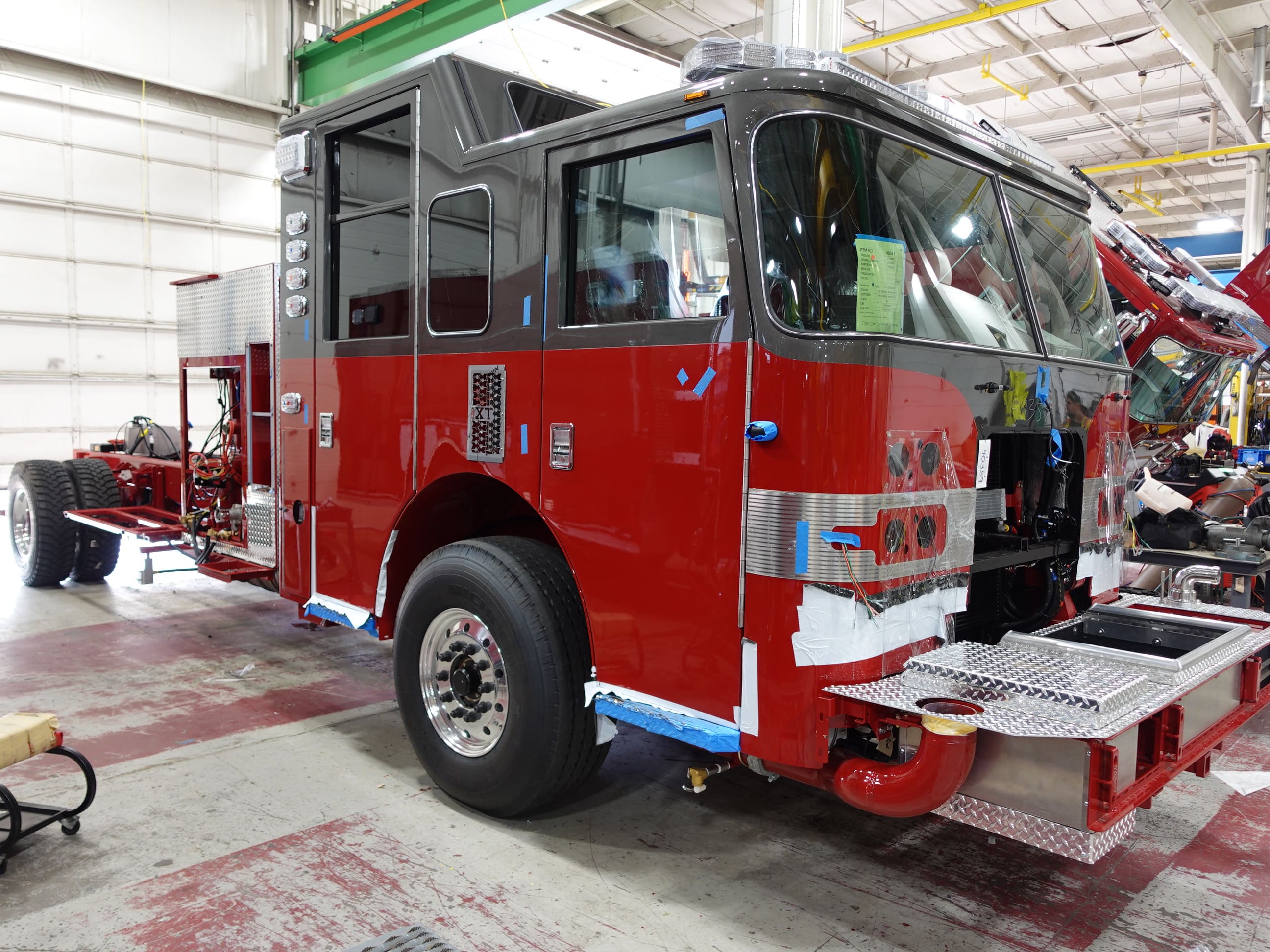

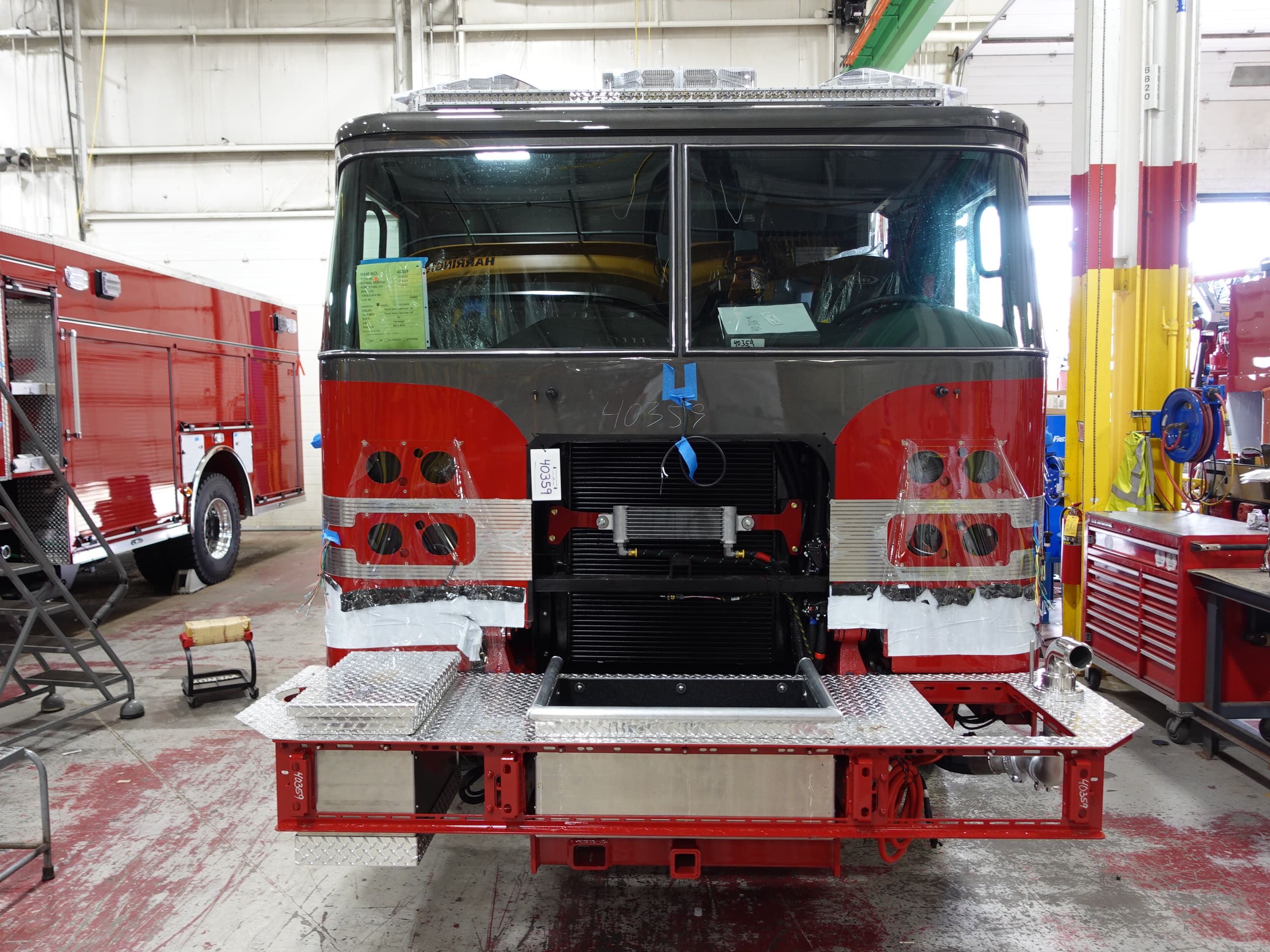

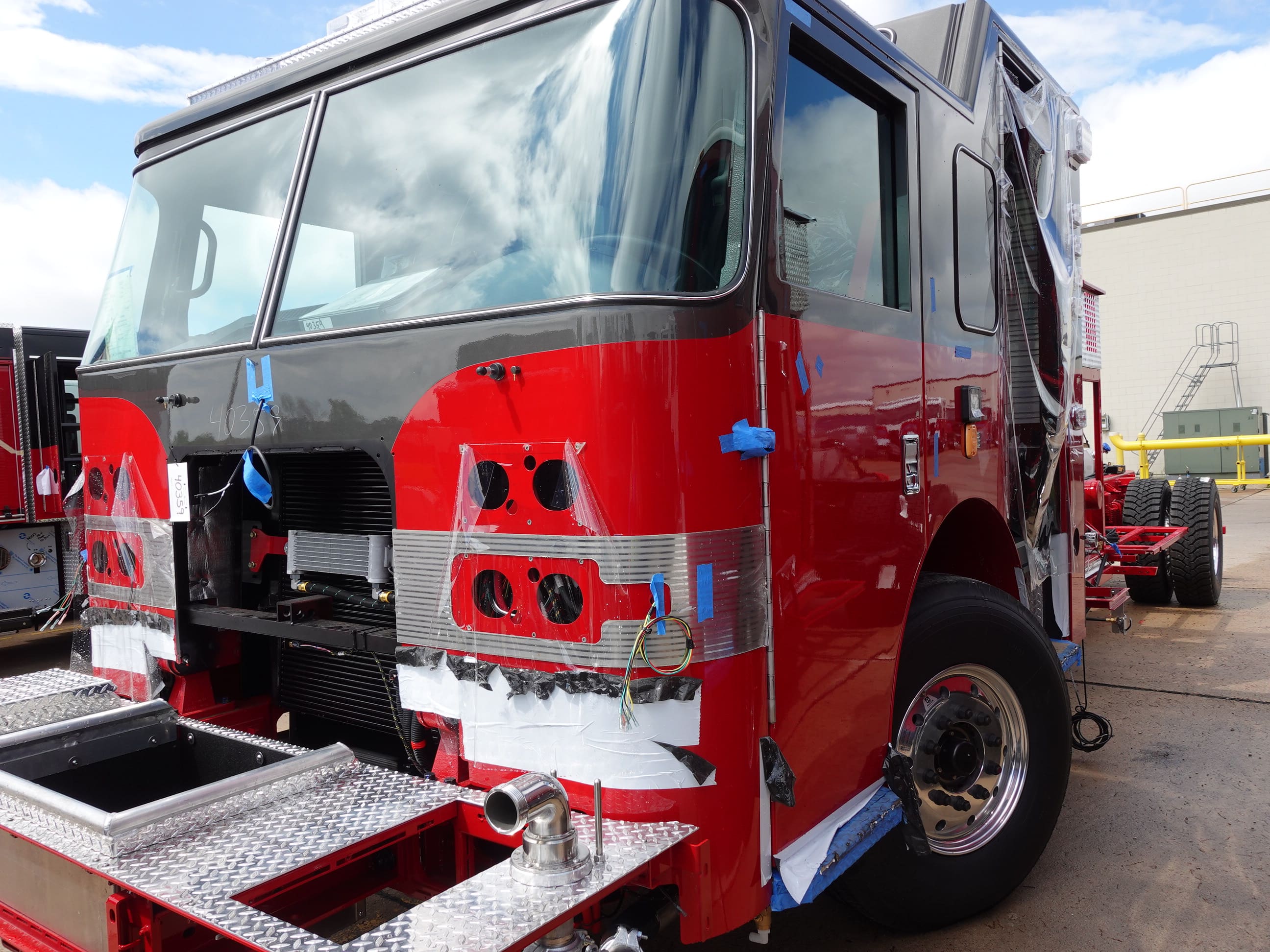

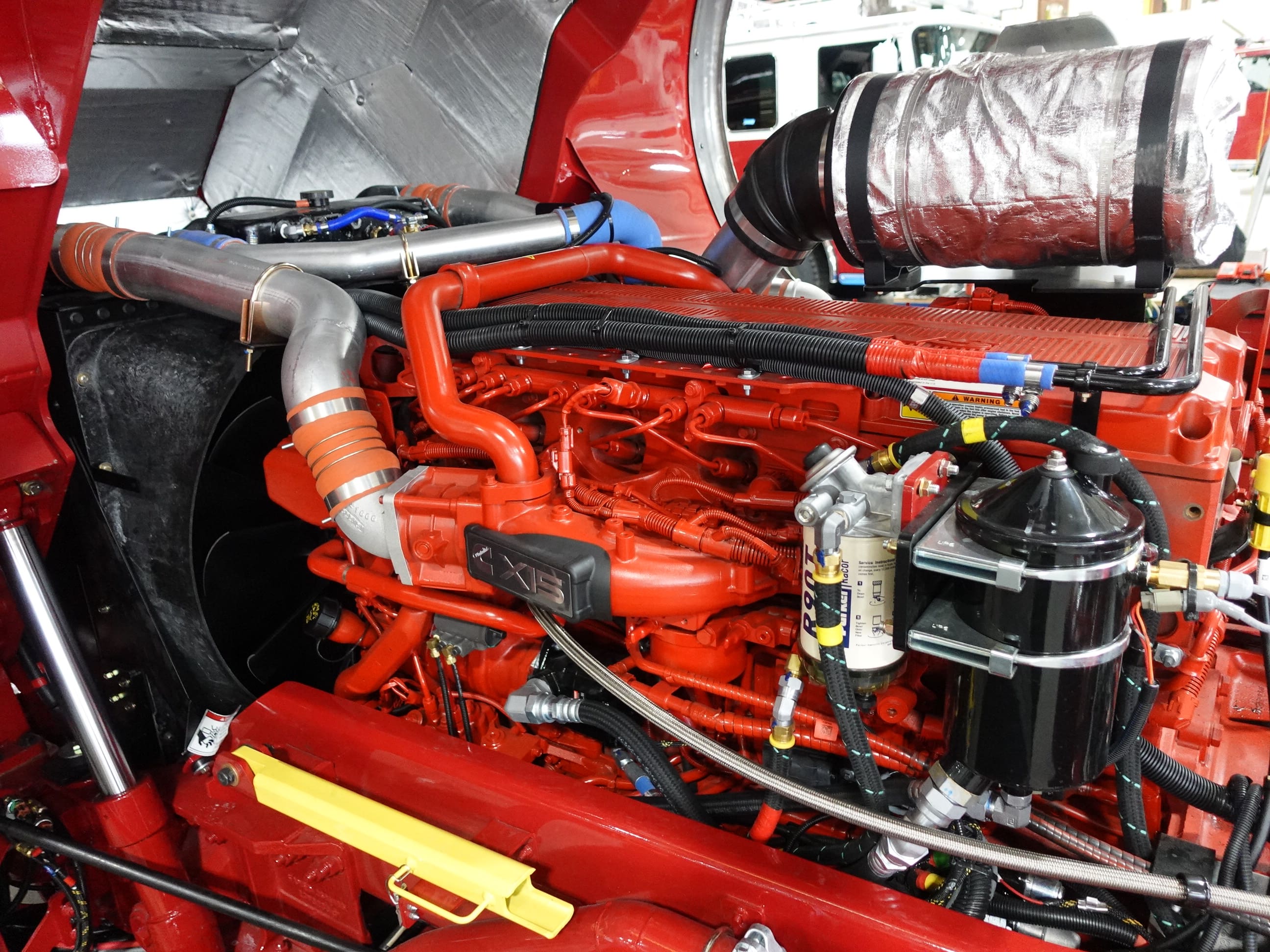

08-21-26

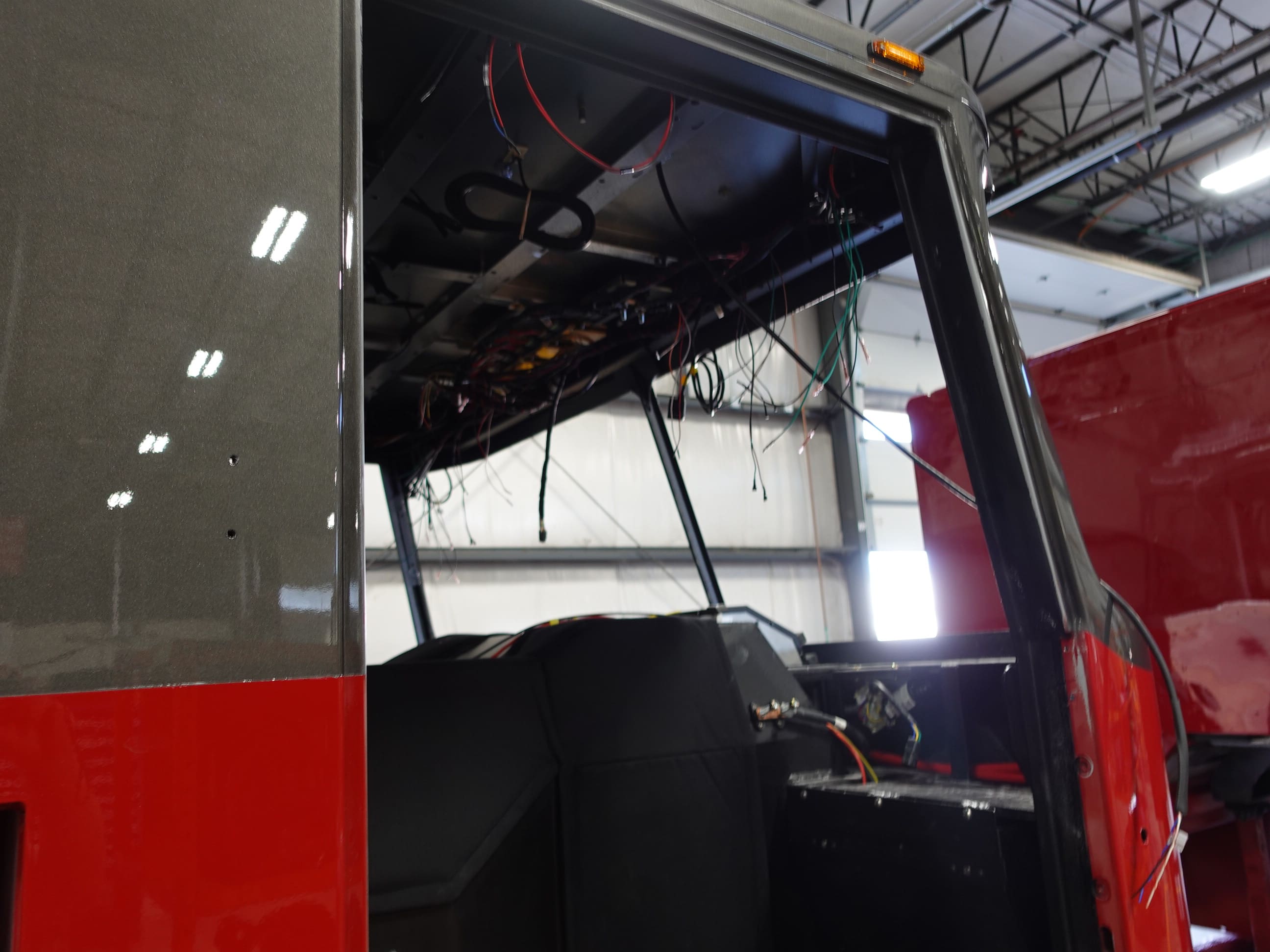

In this report, the apparatus continued the traditional

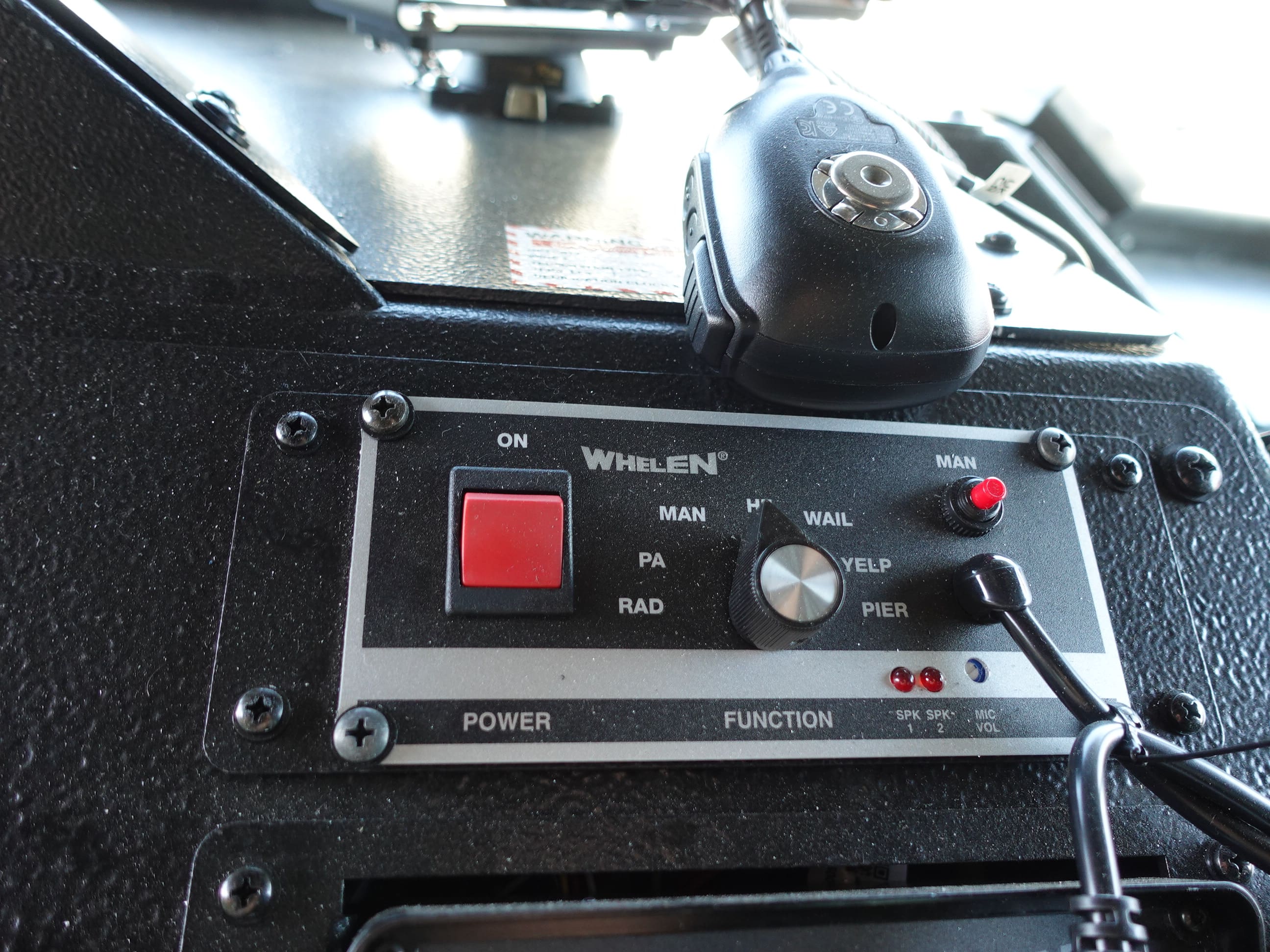

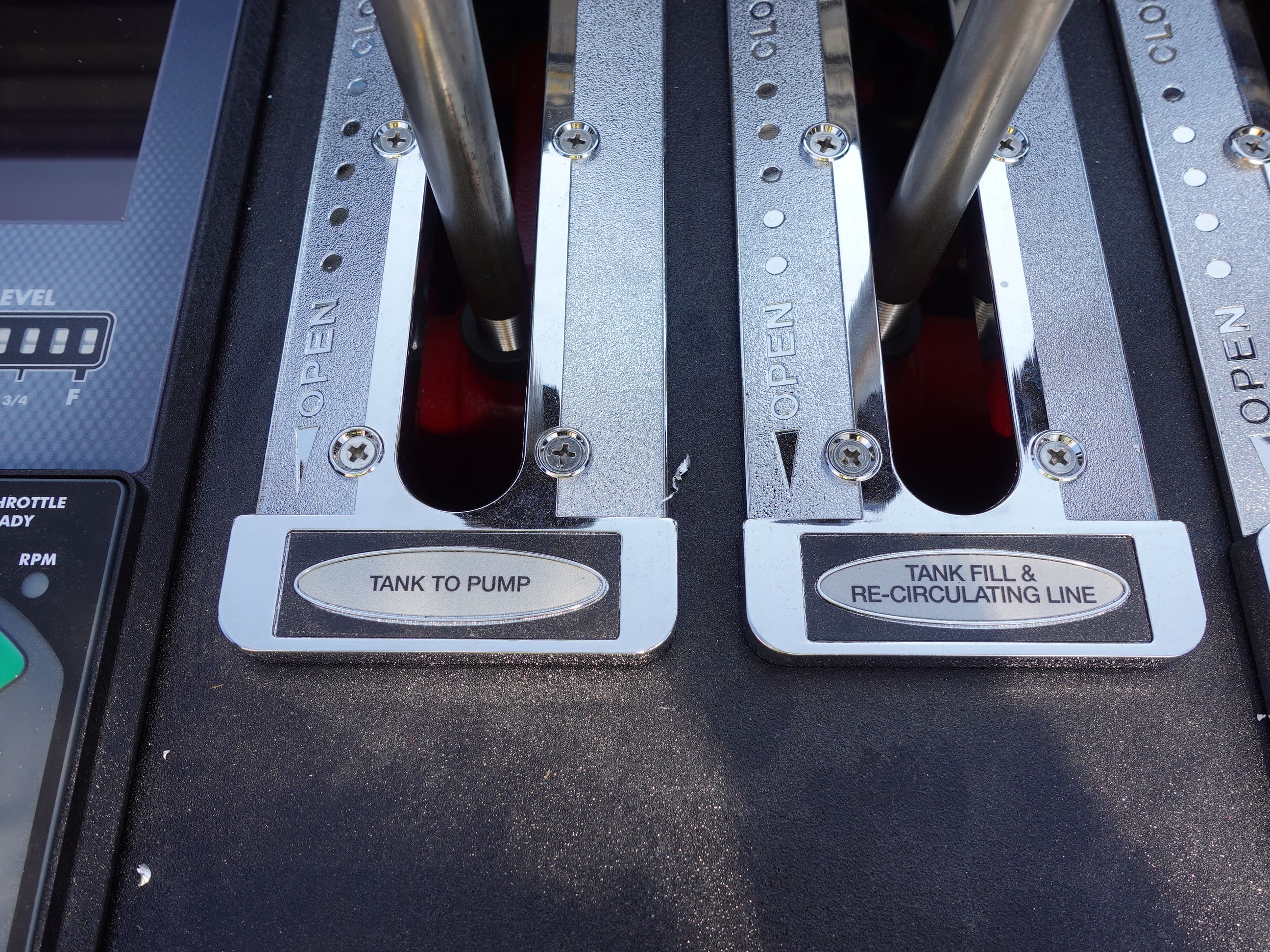

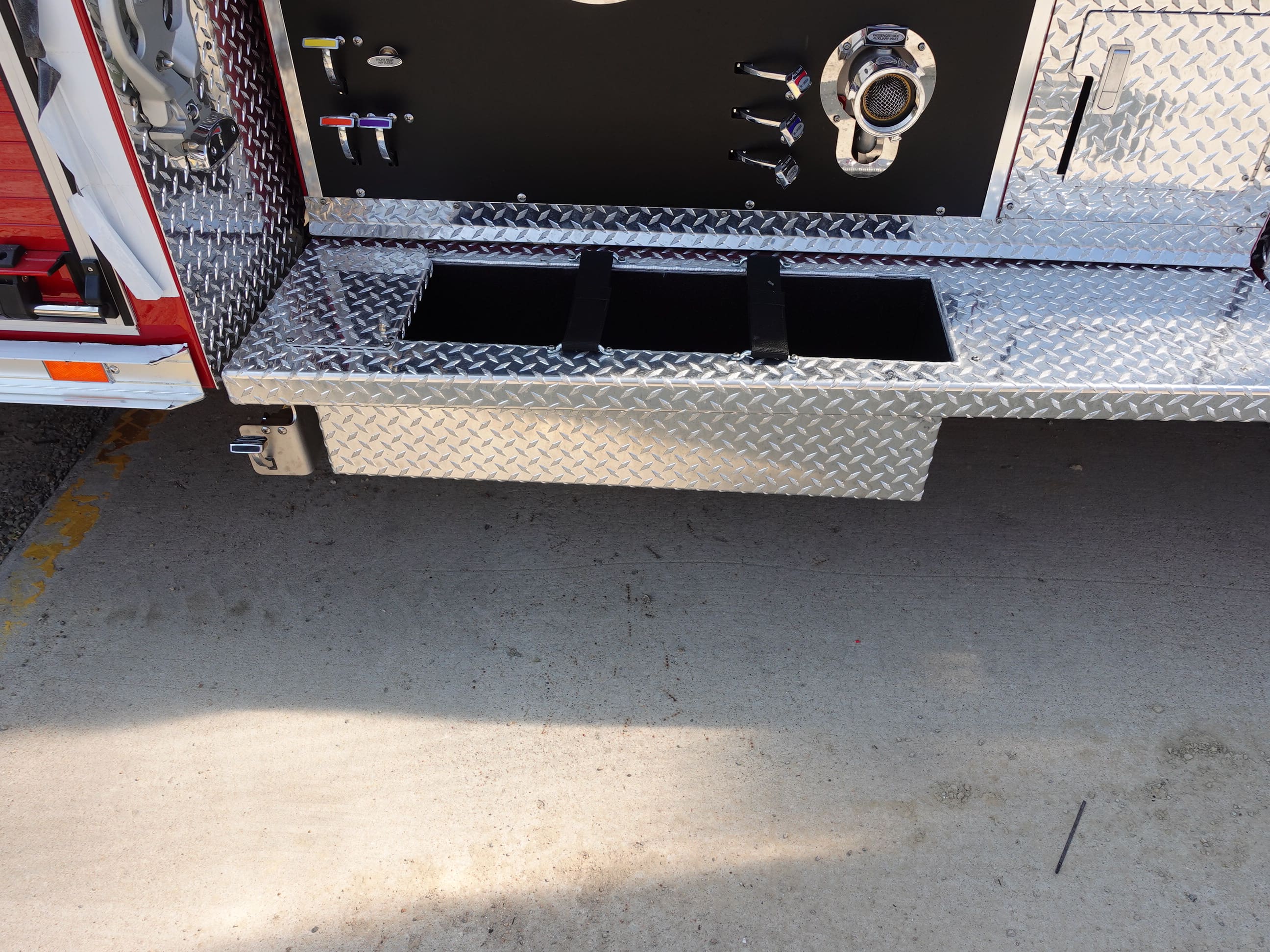

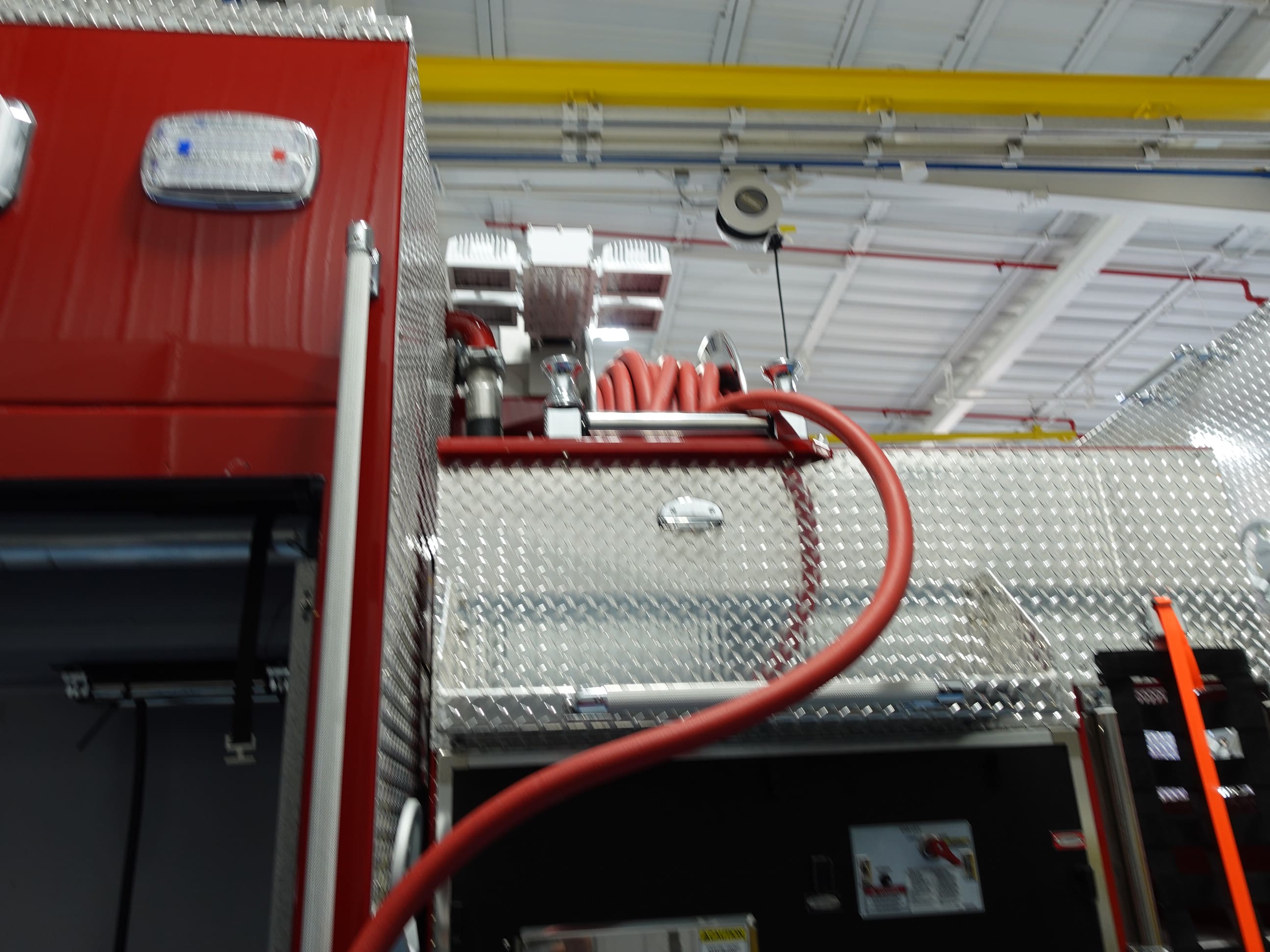

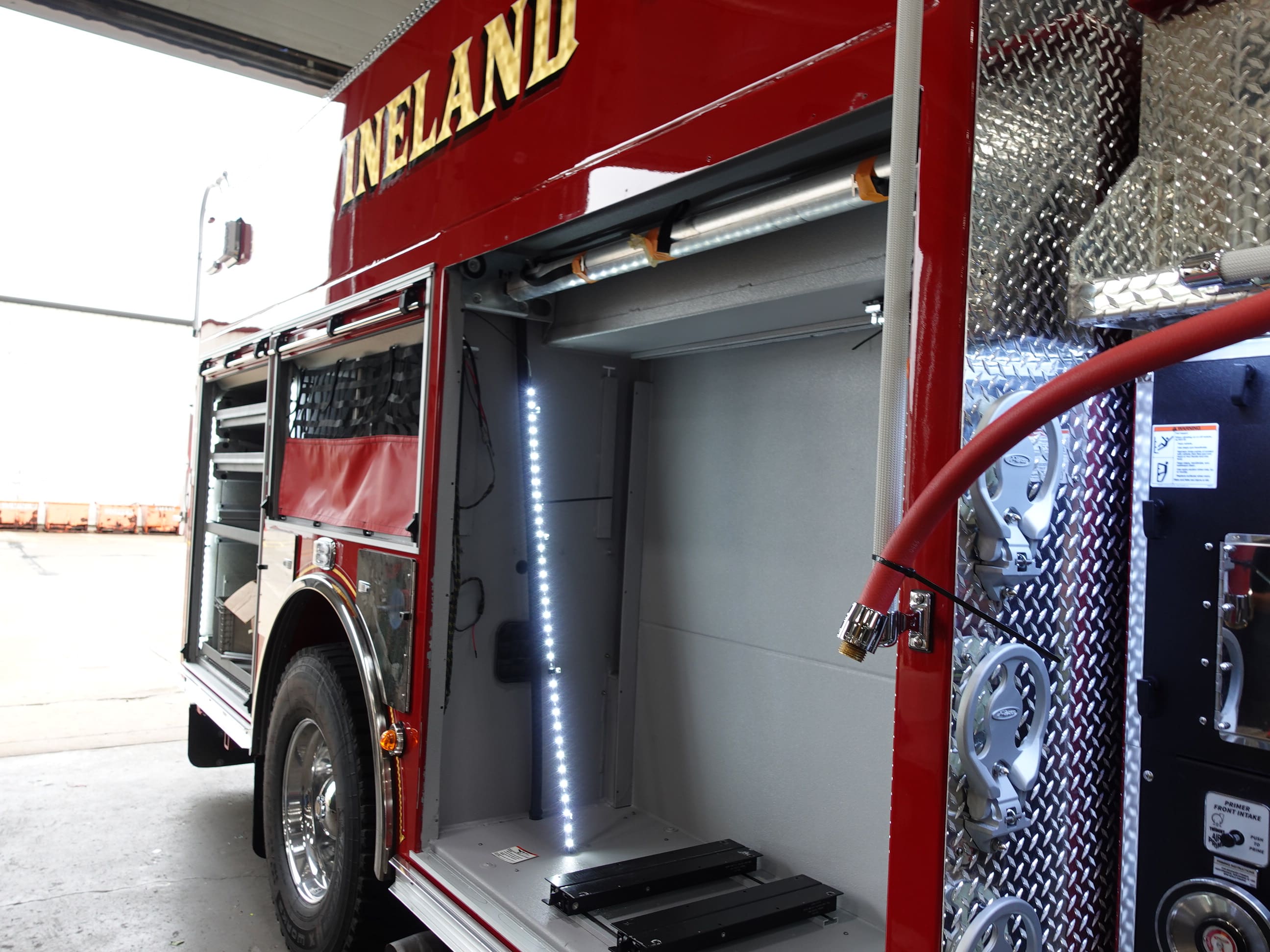

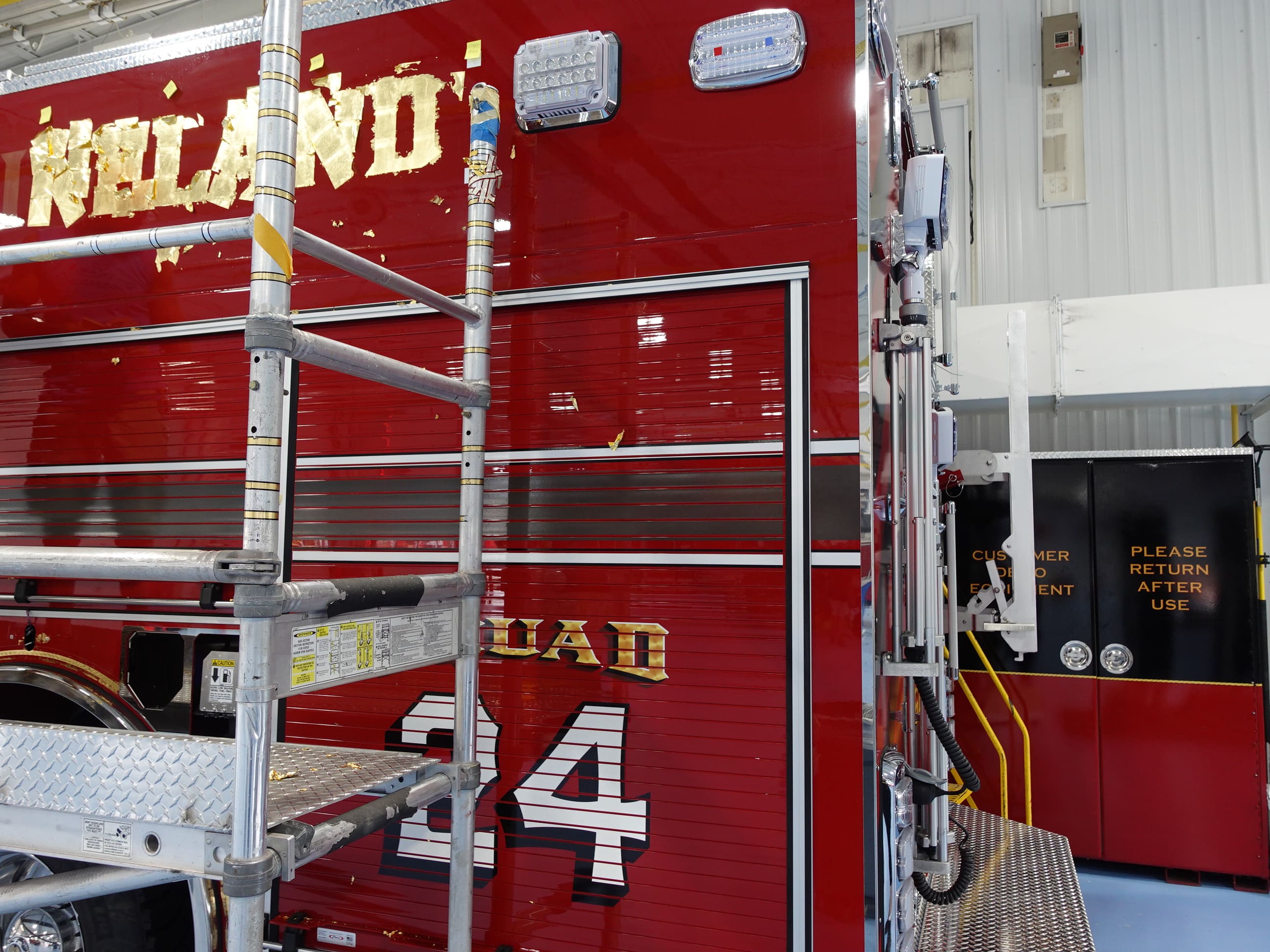

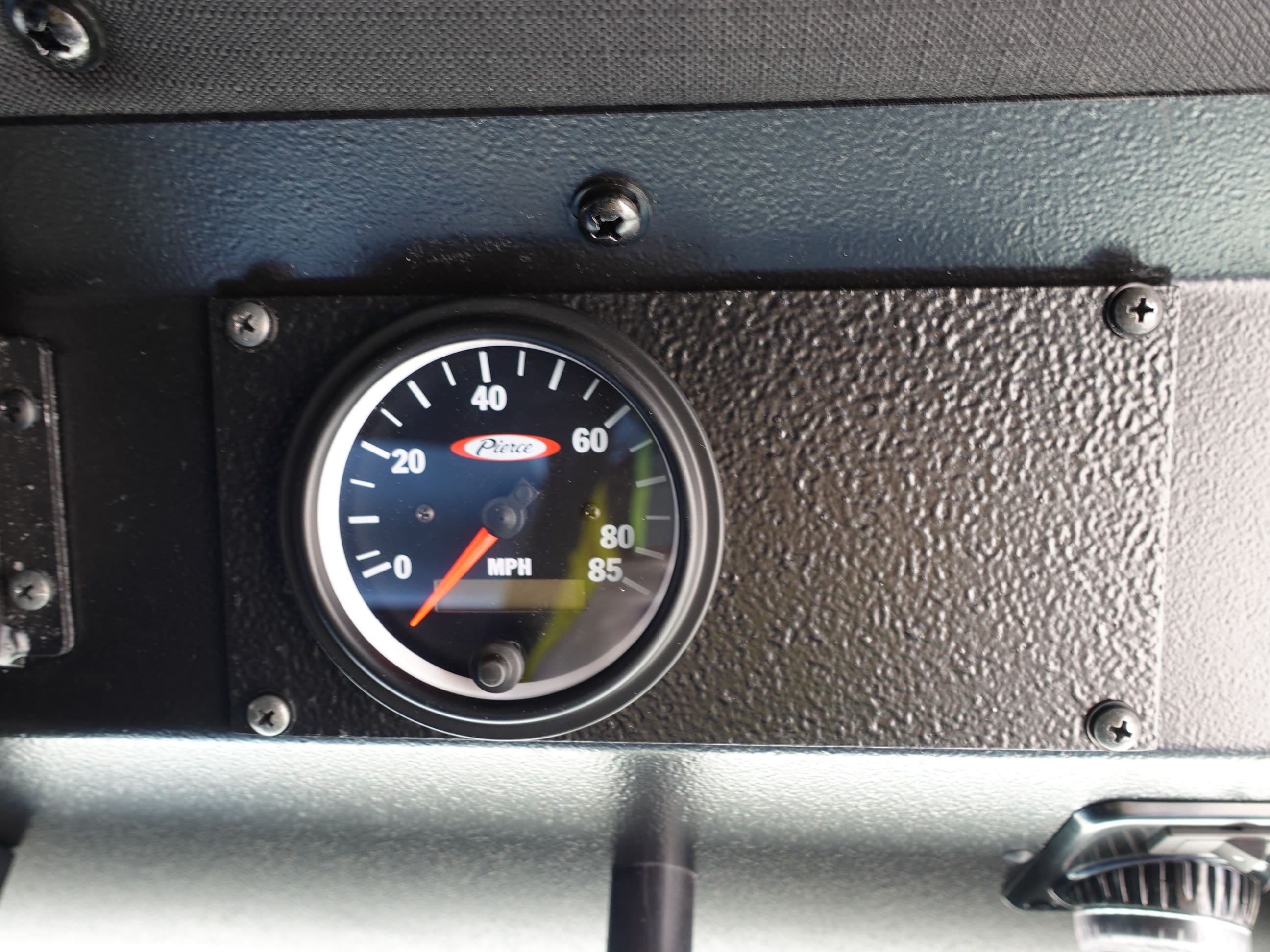

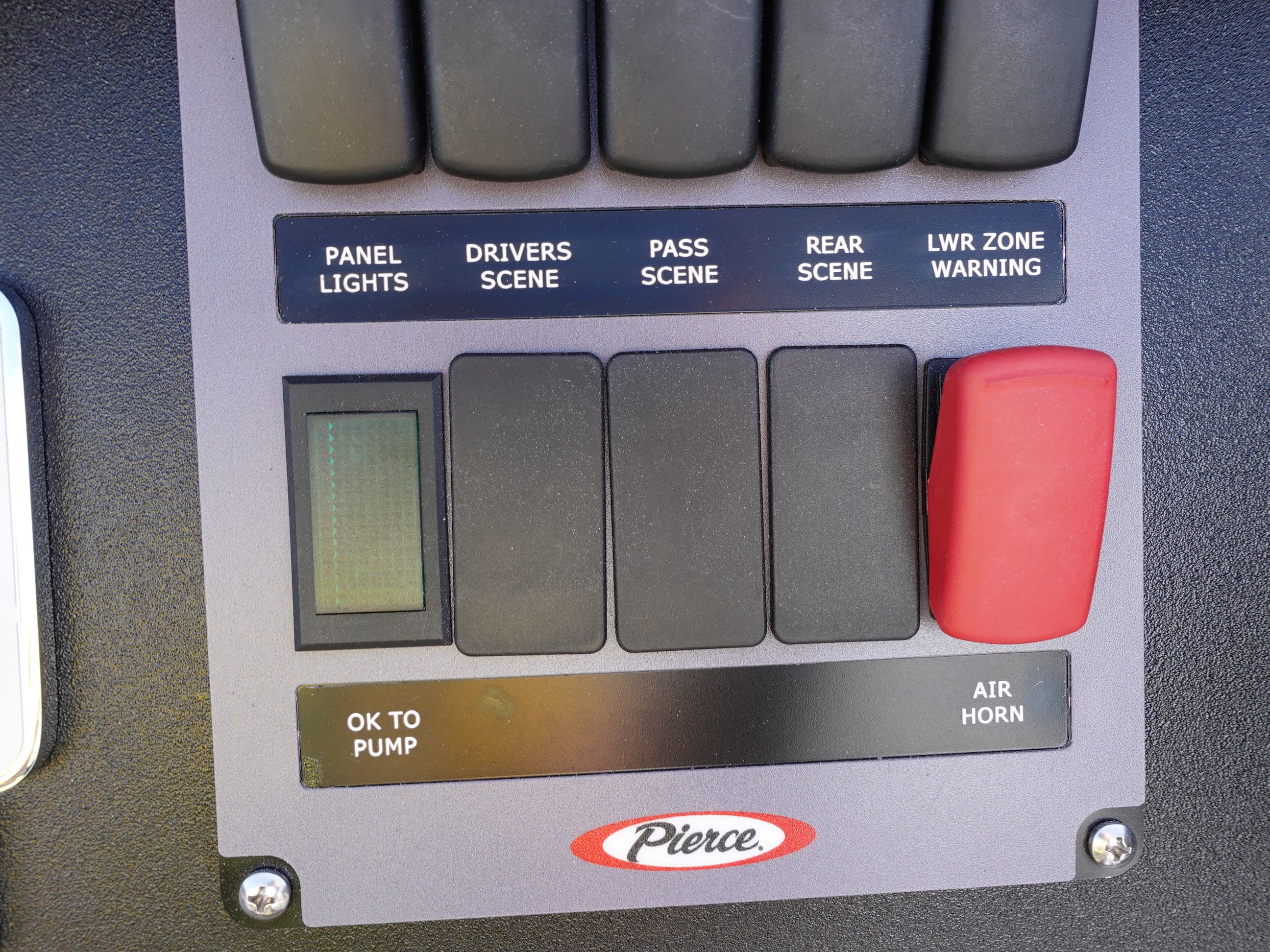

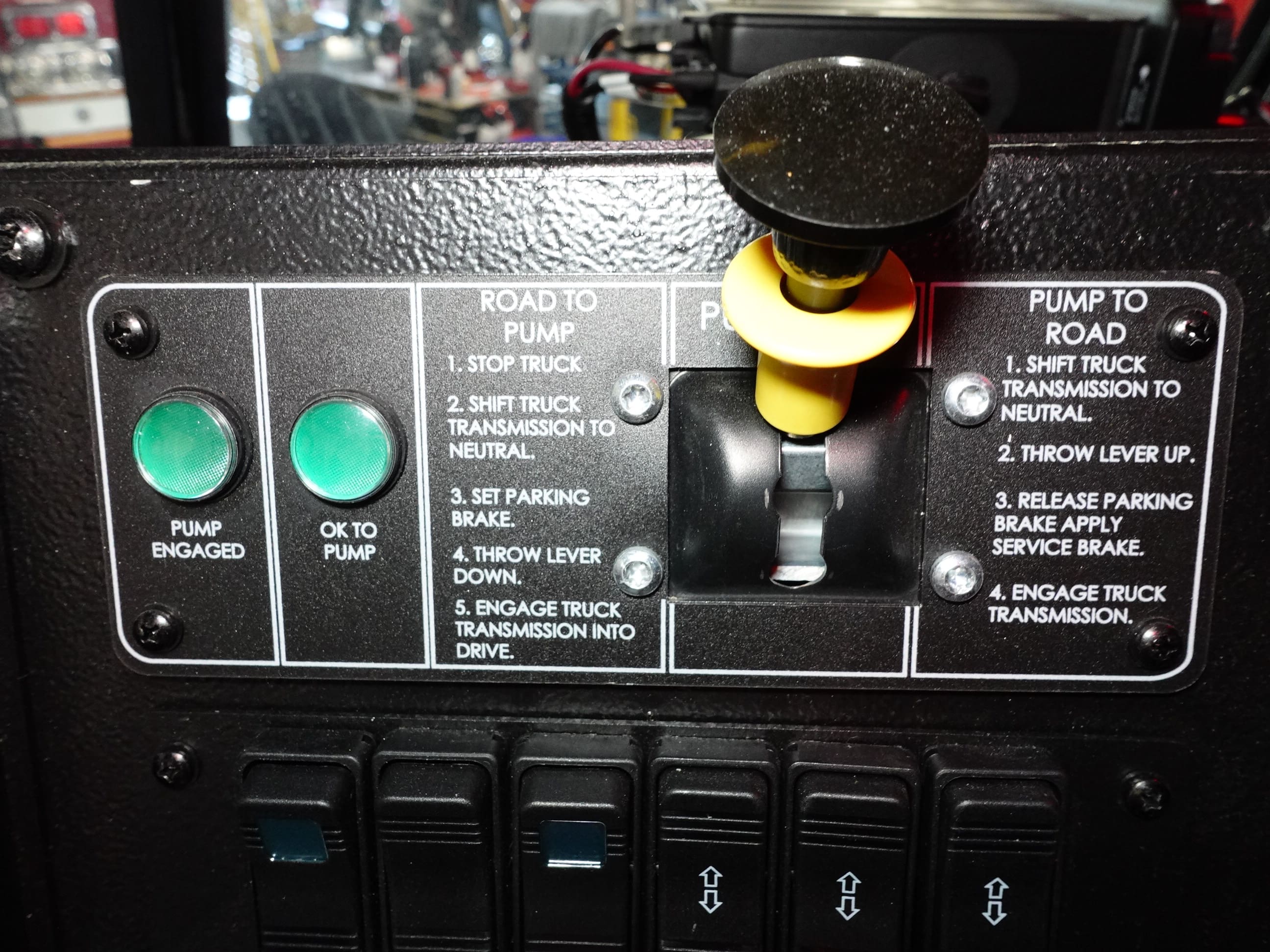

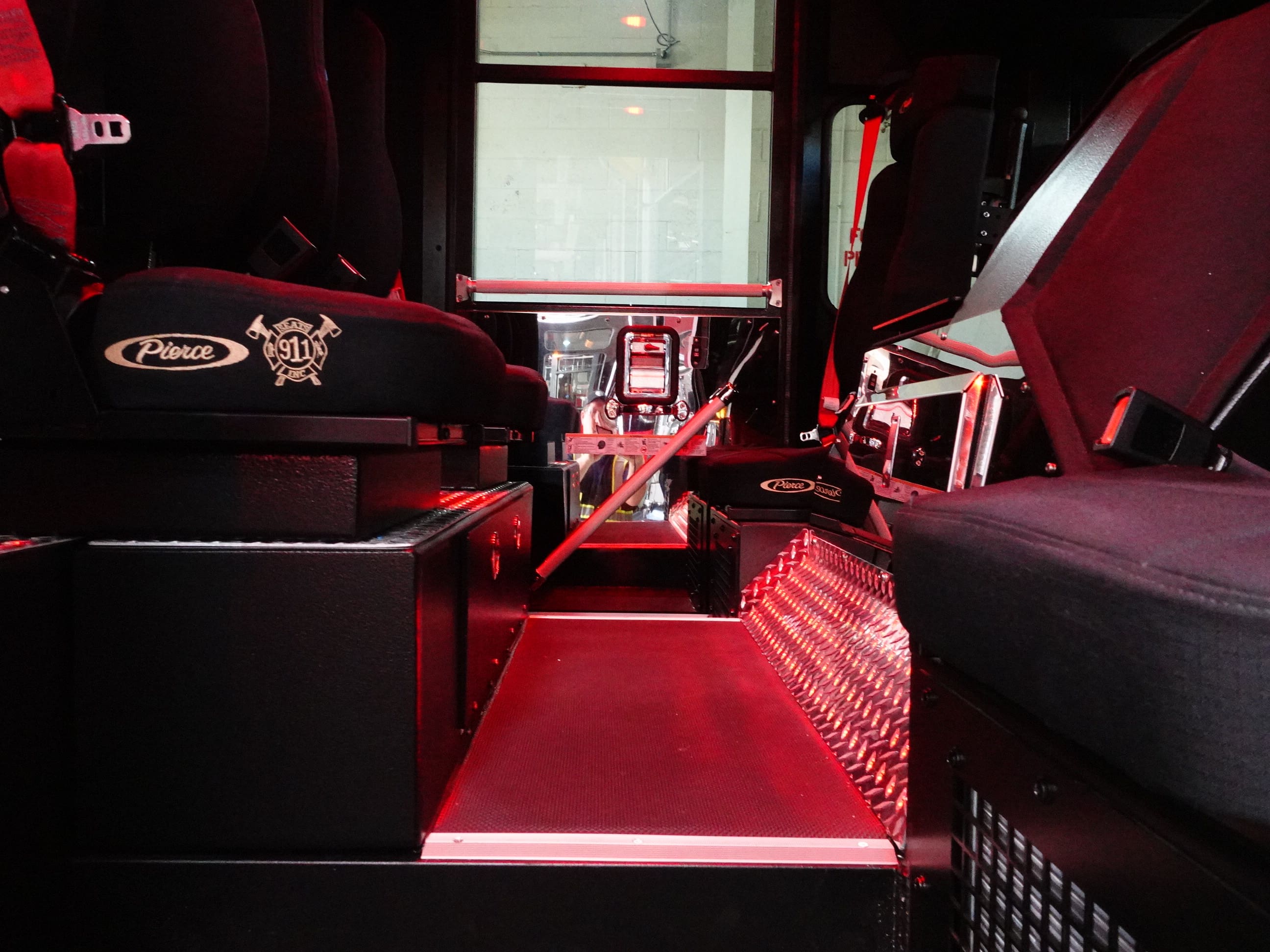

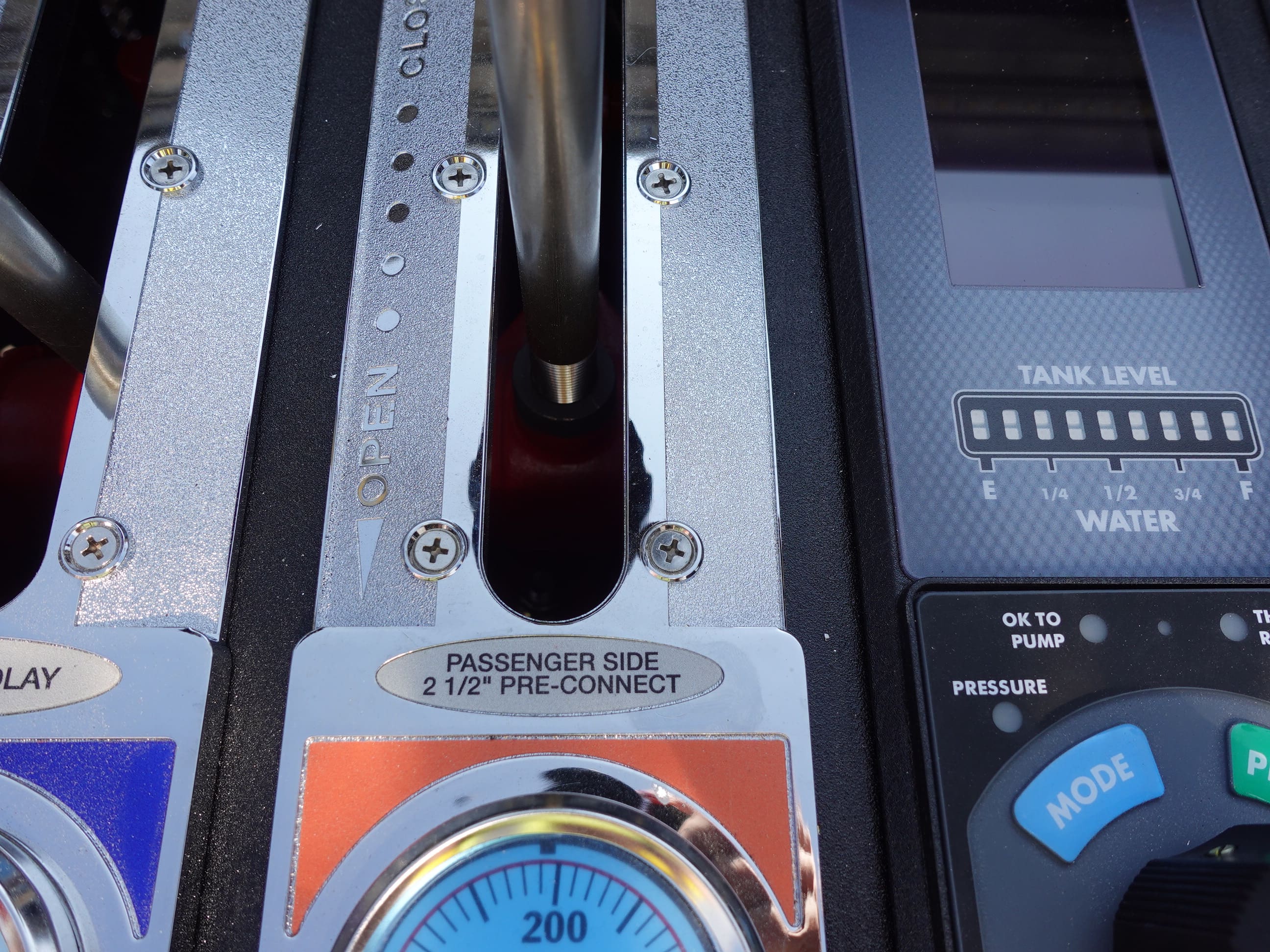

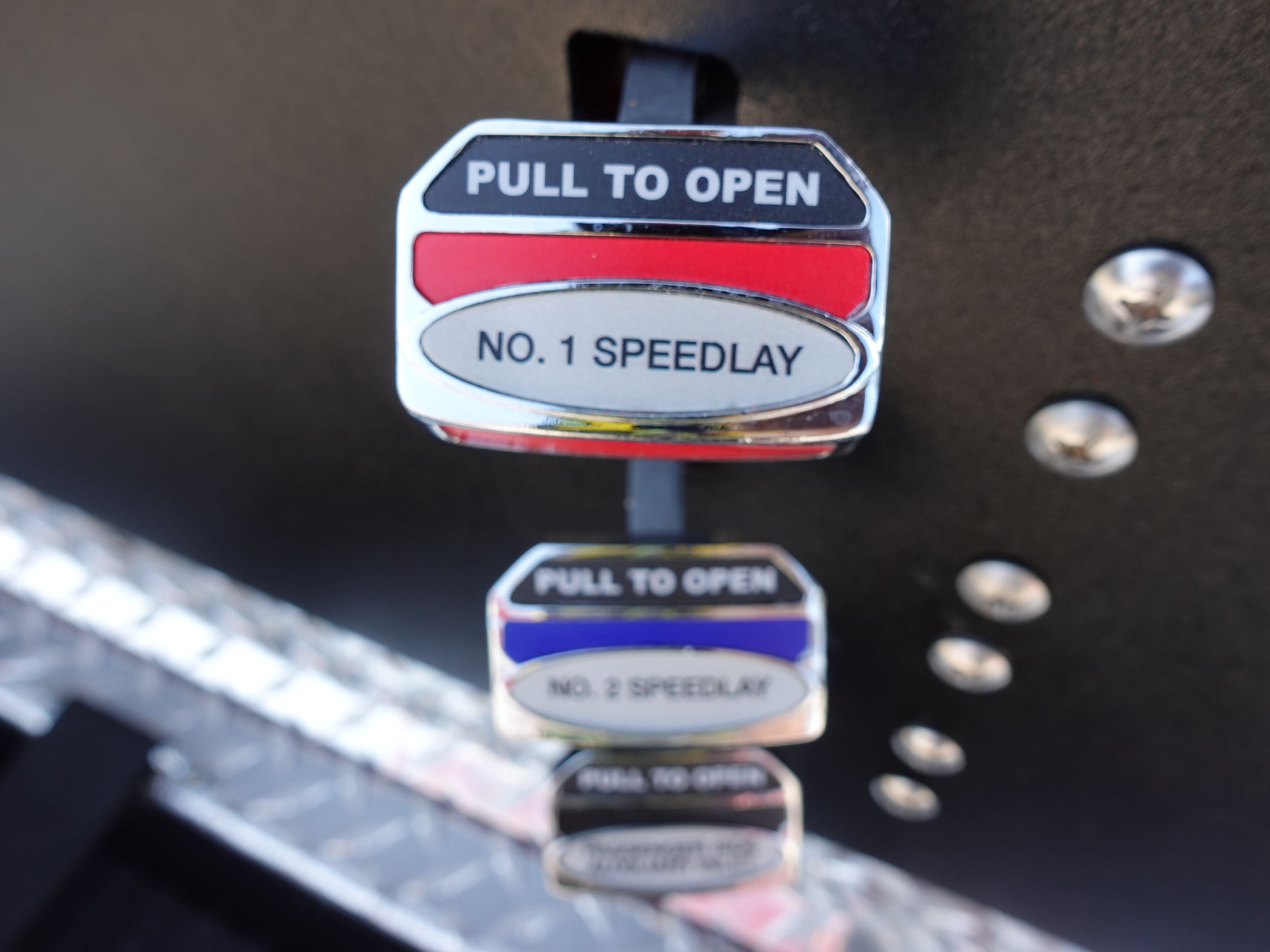

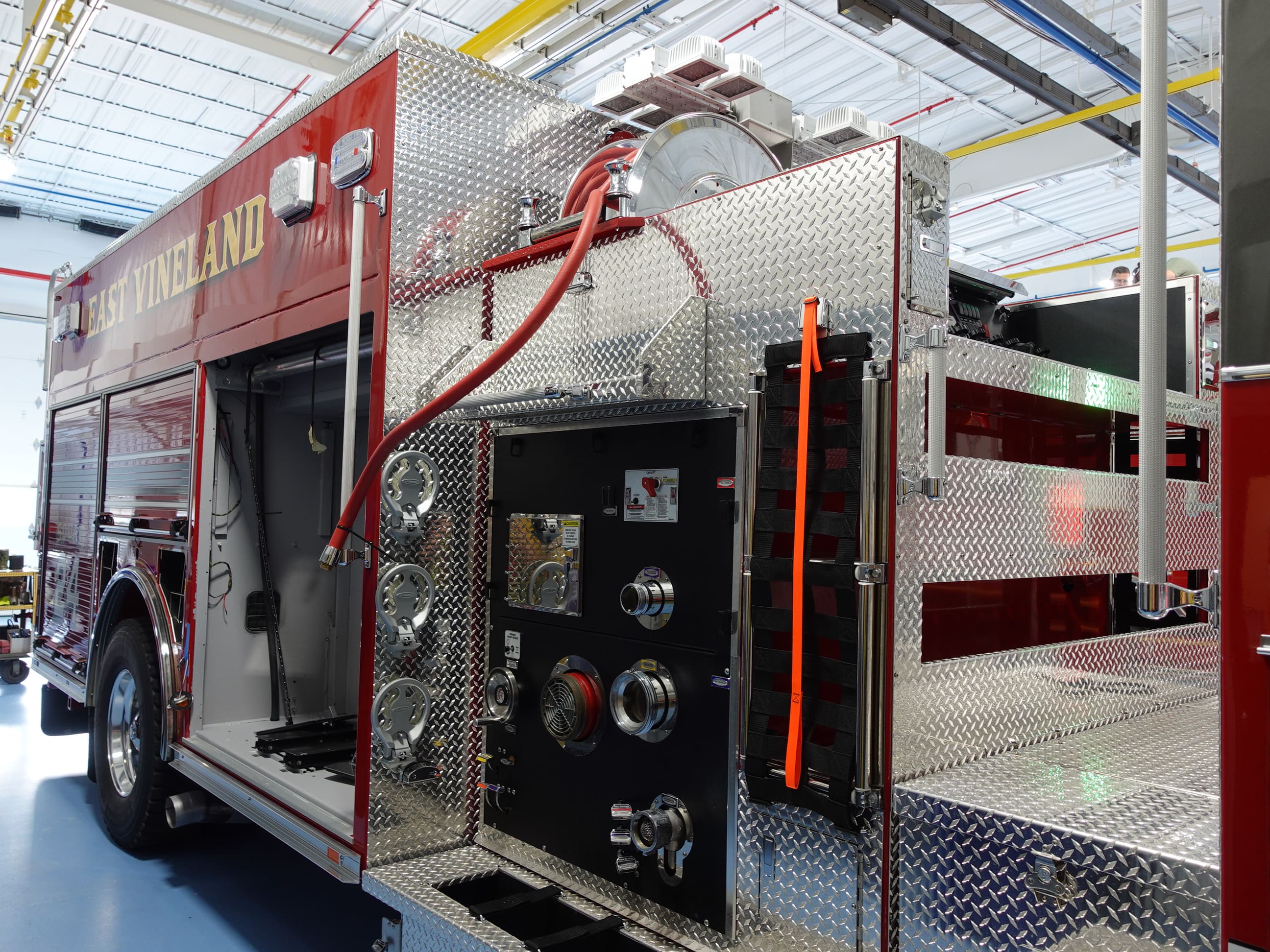

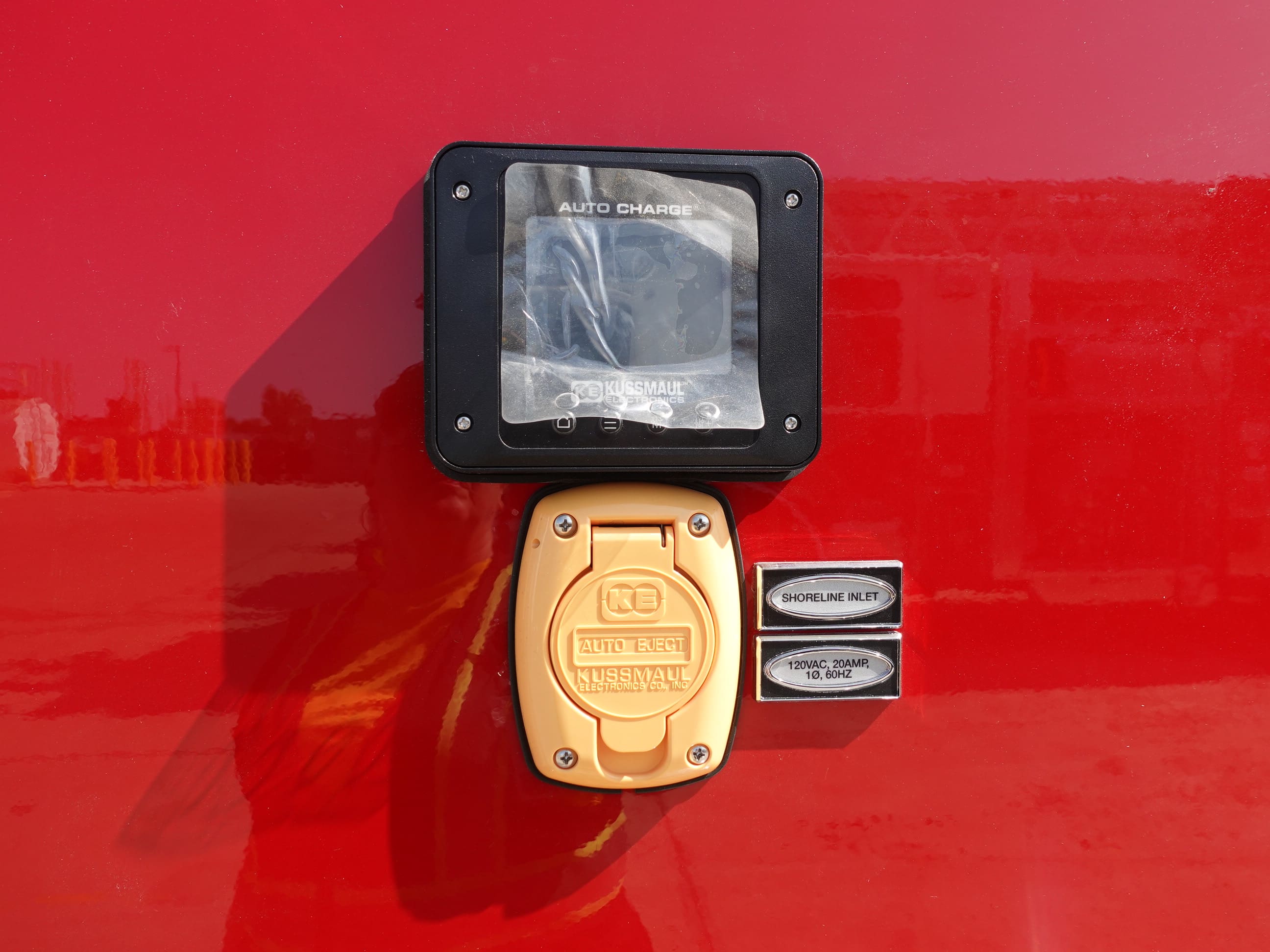

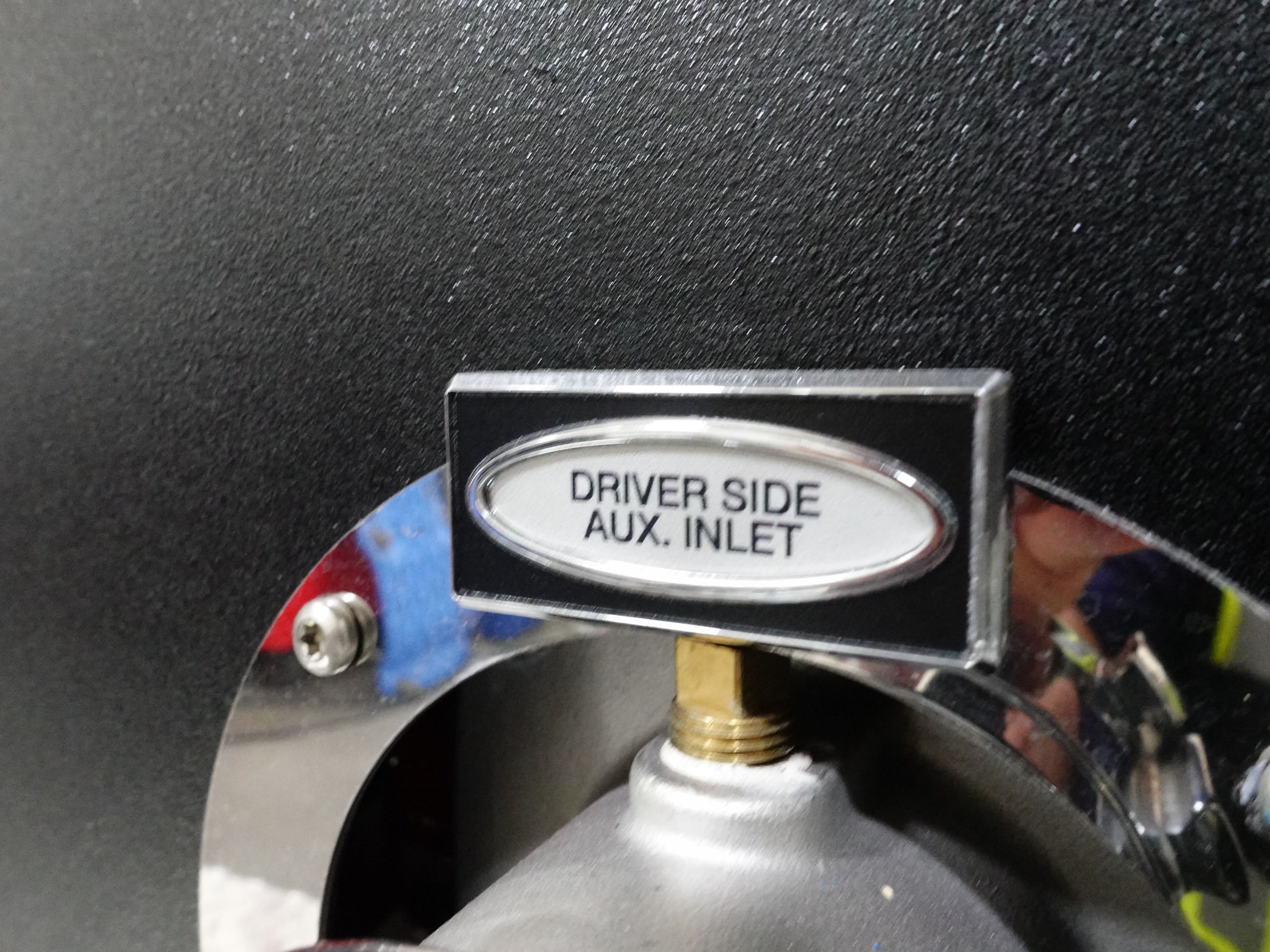

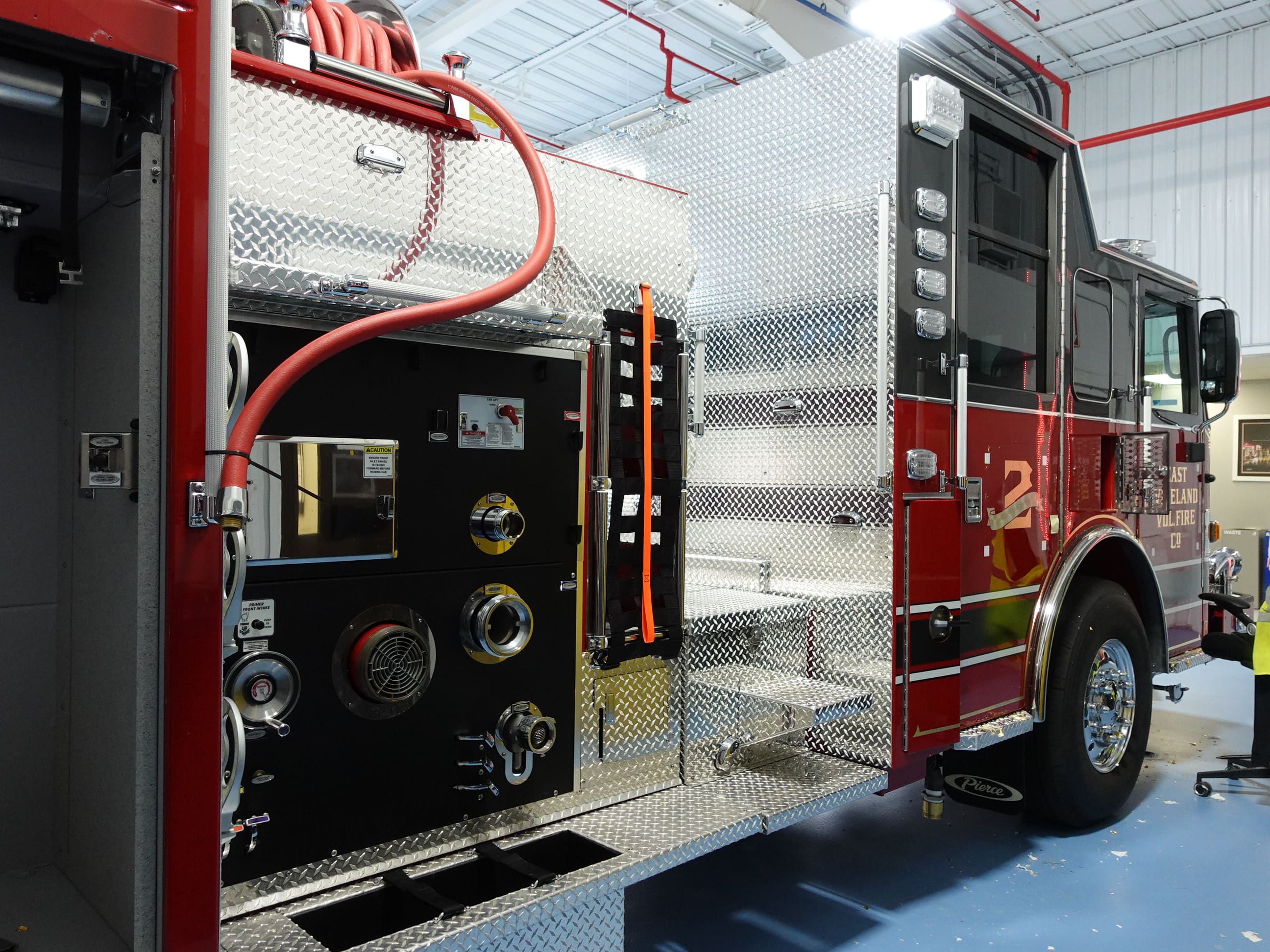

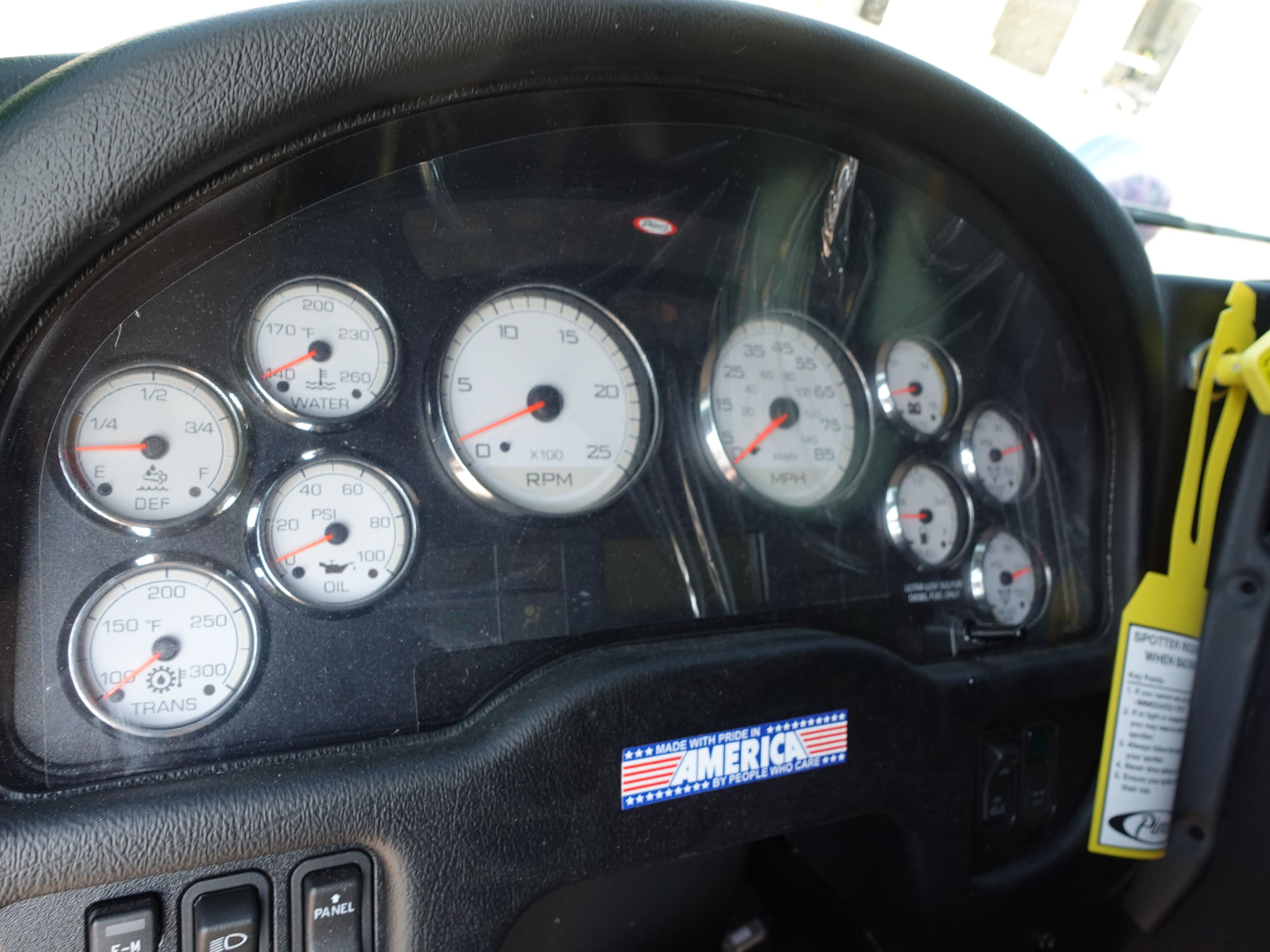

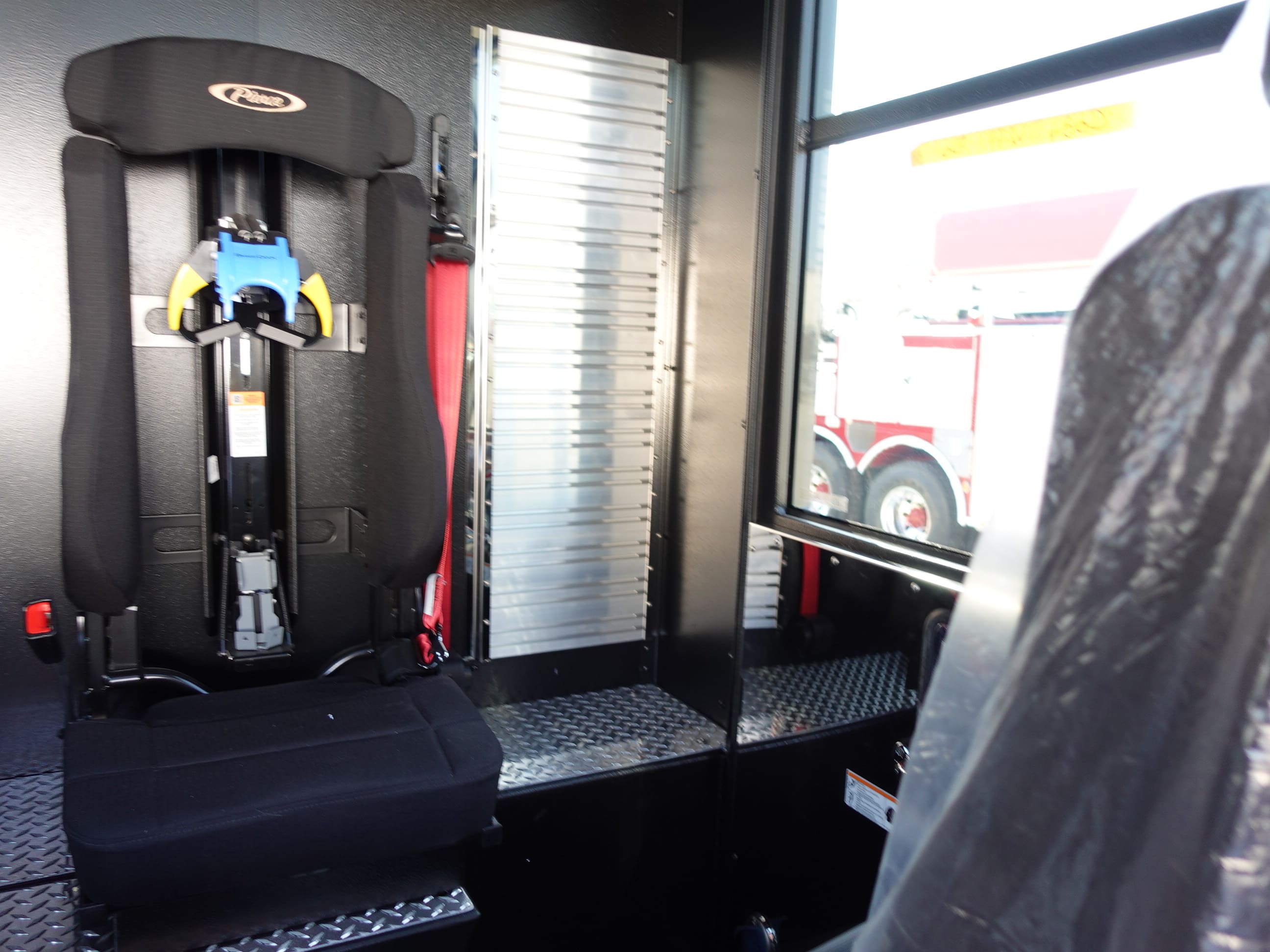

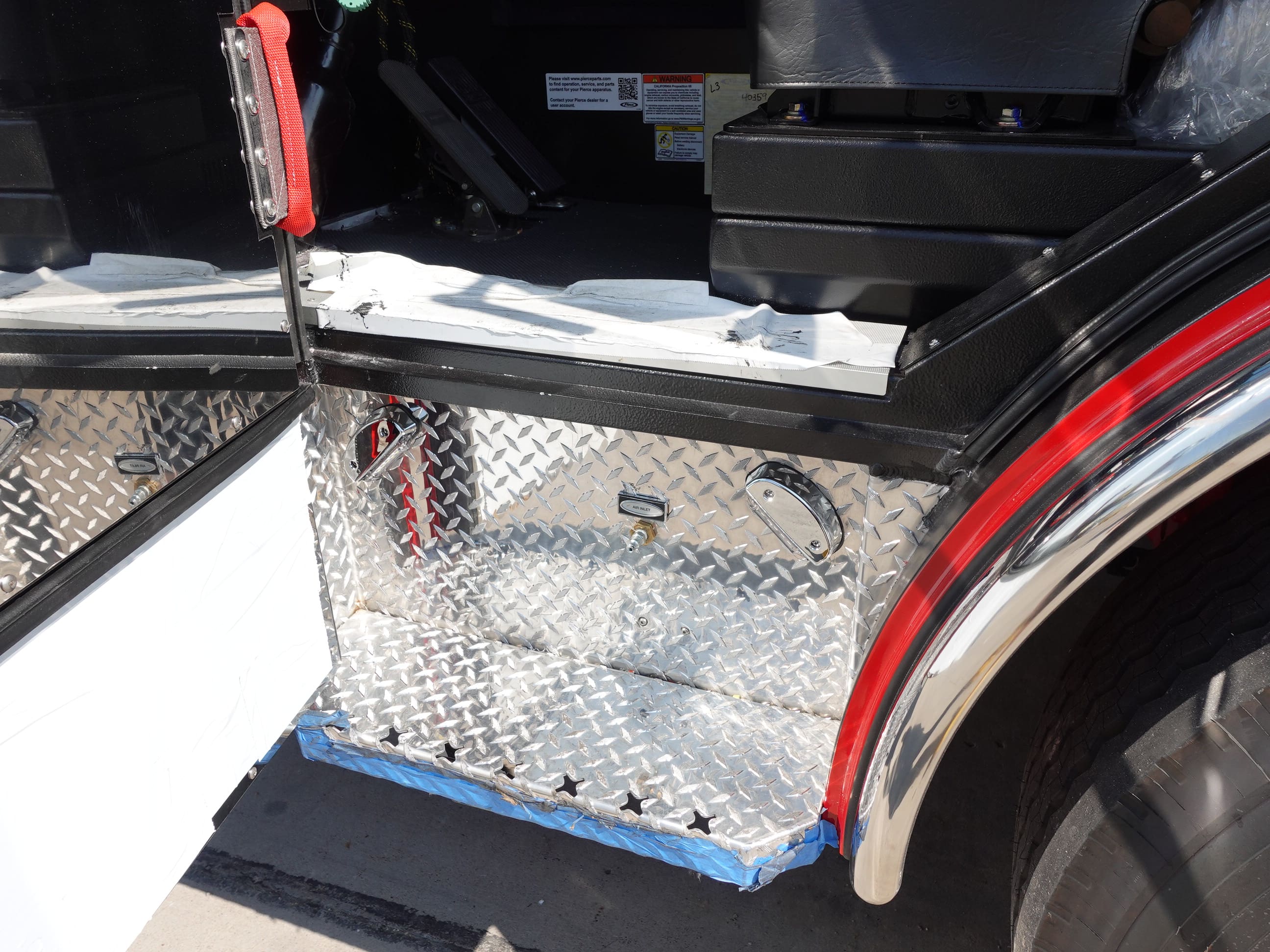

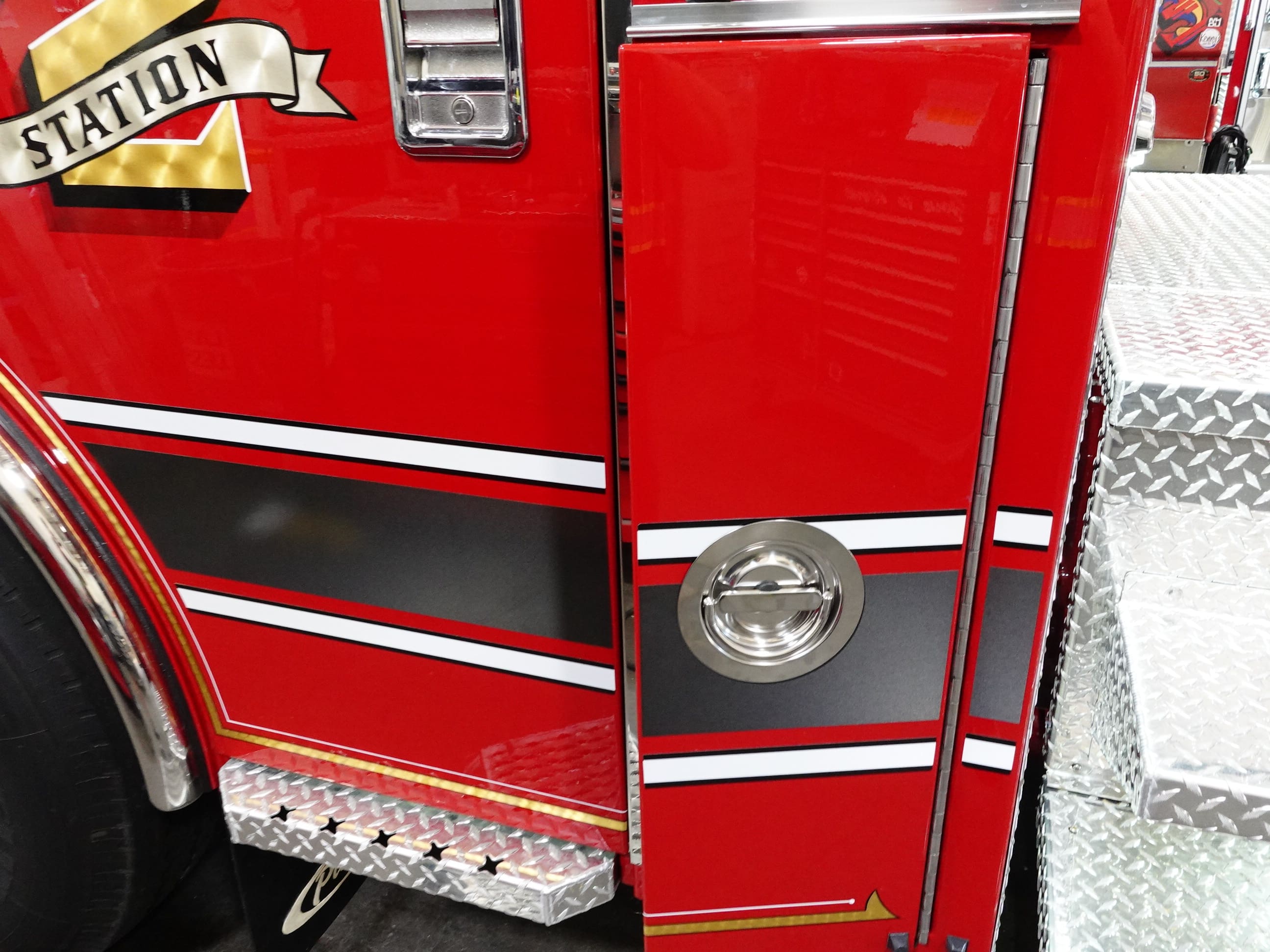

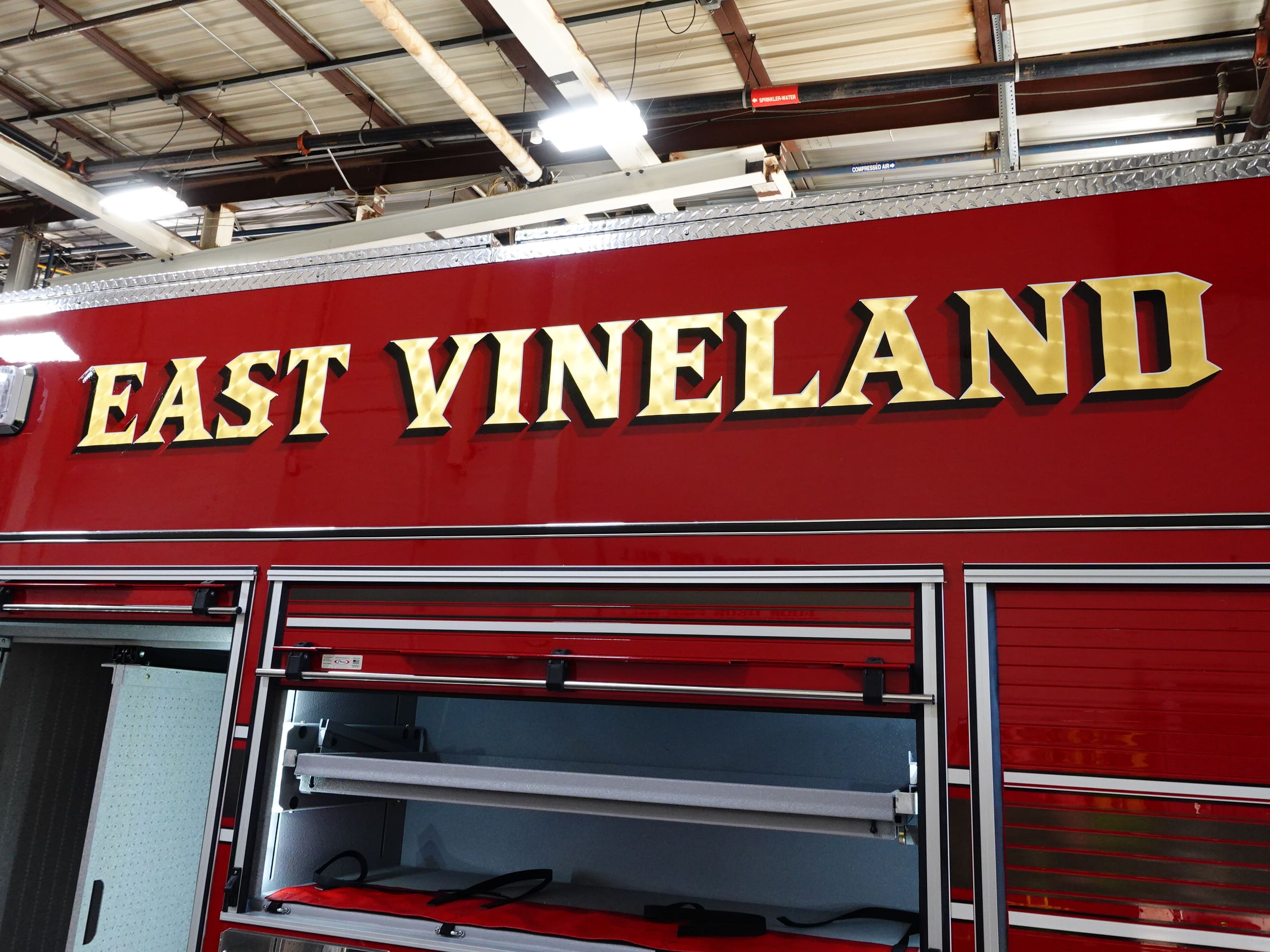

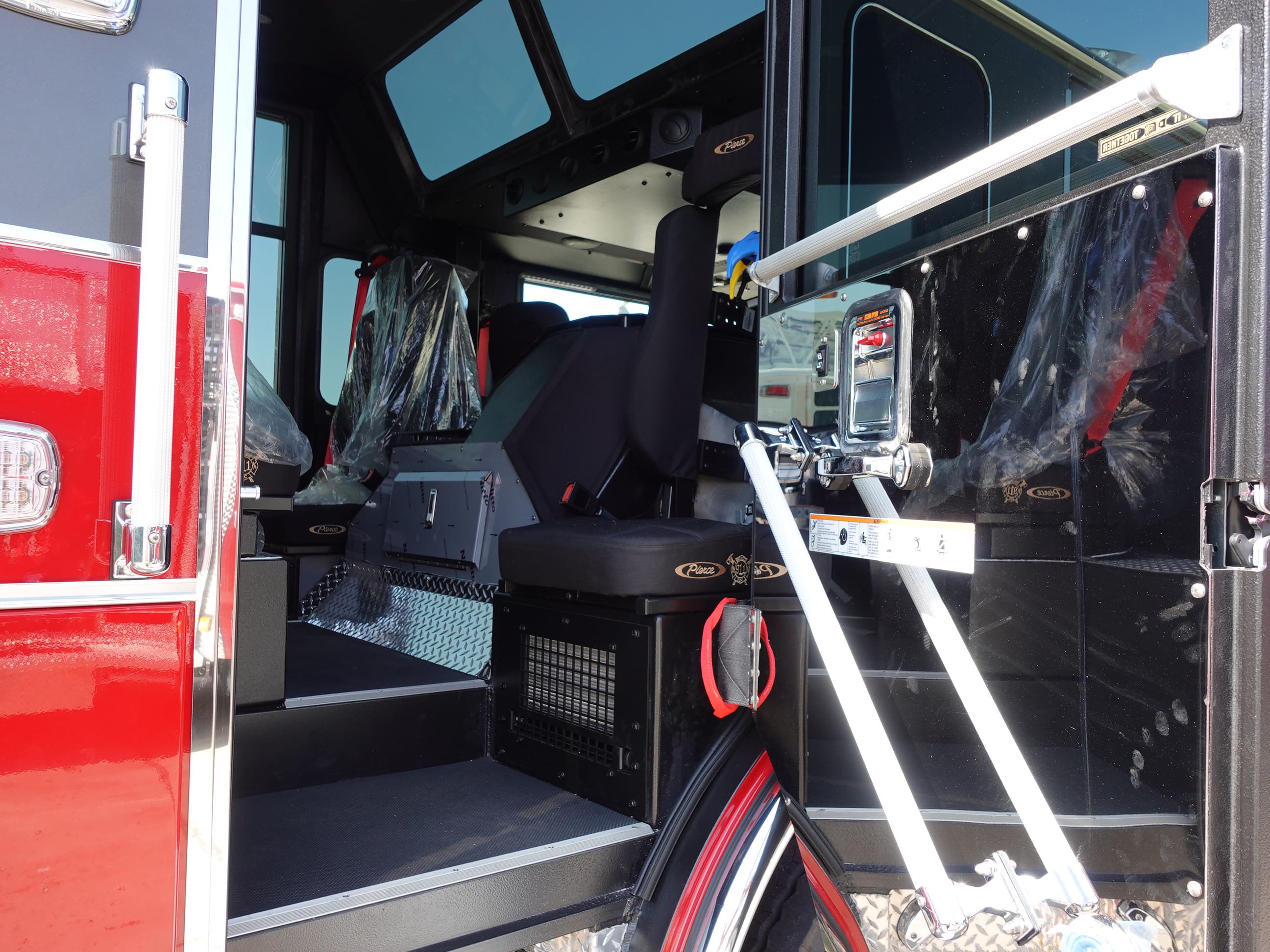

gold leaf graphic application process.
08-14-26

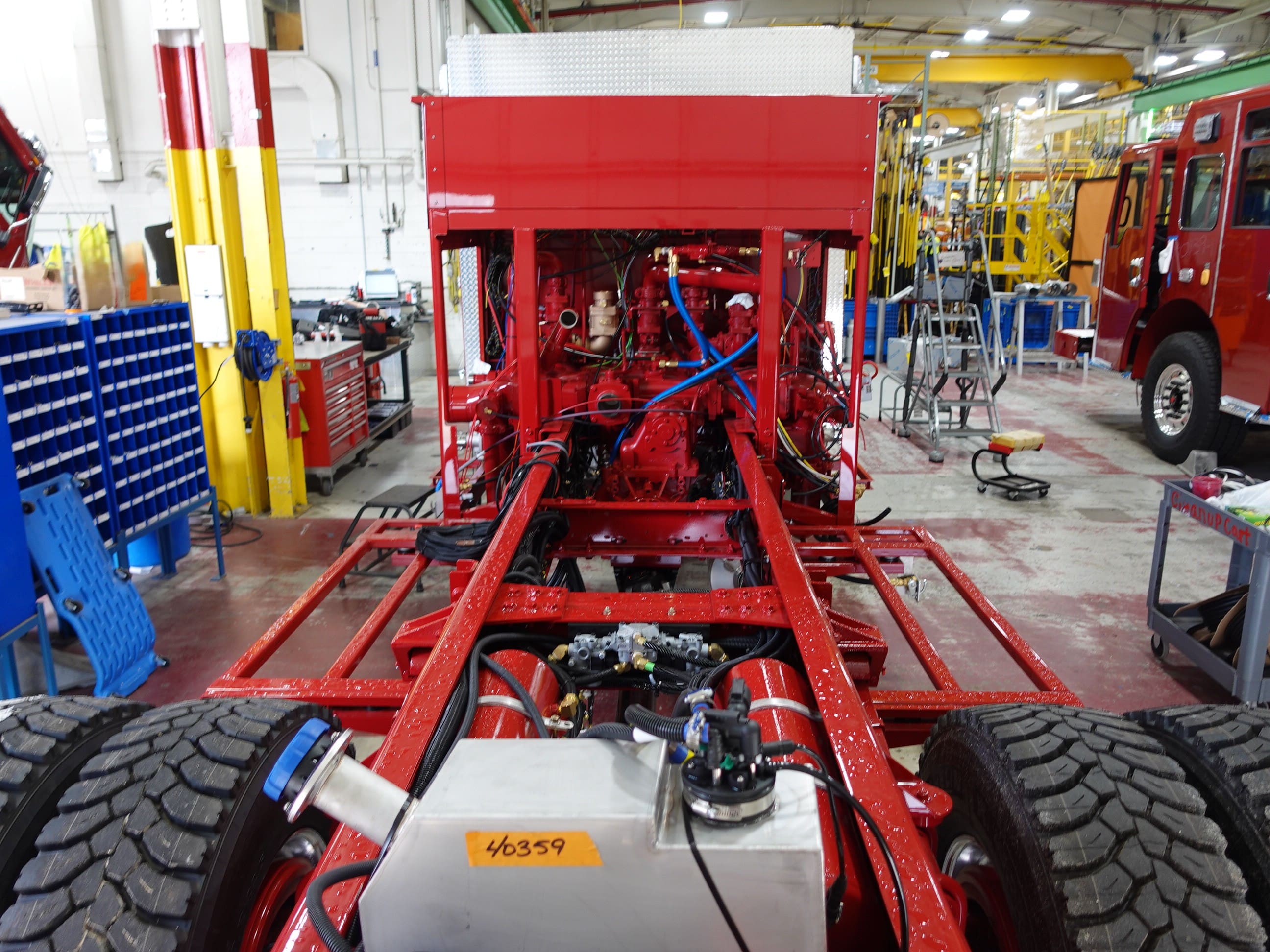

In this report, the apparatus began the traditional gold leaf application process.

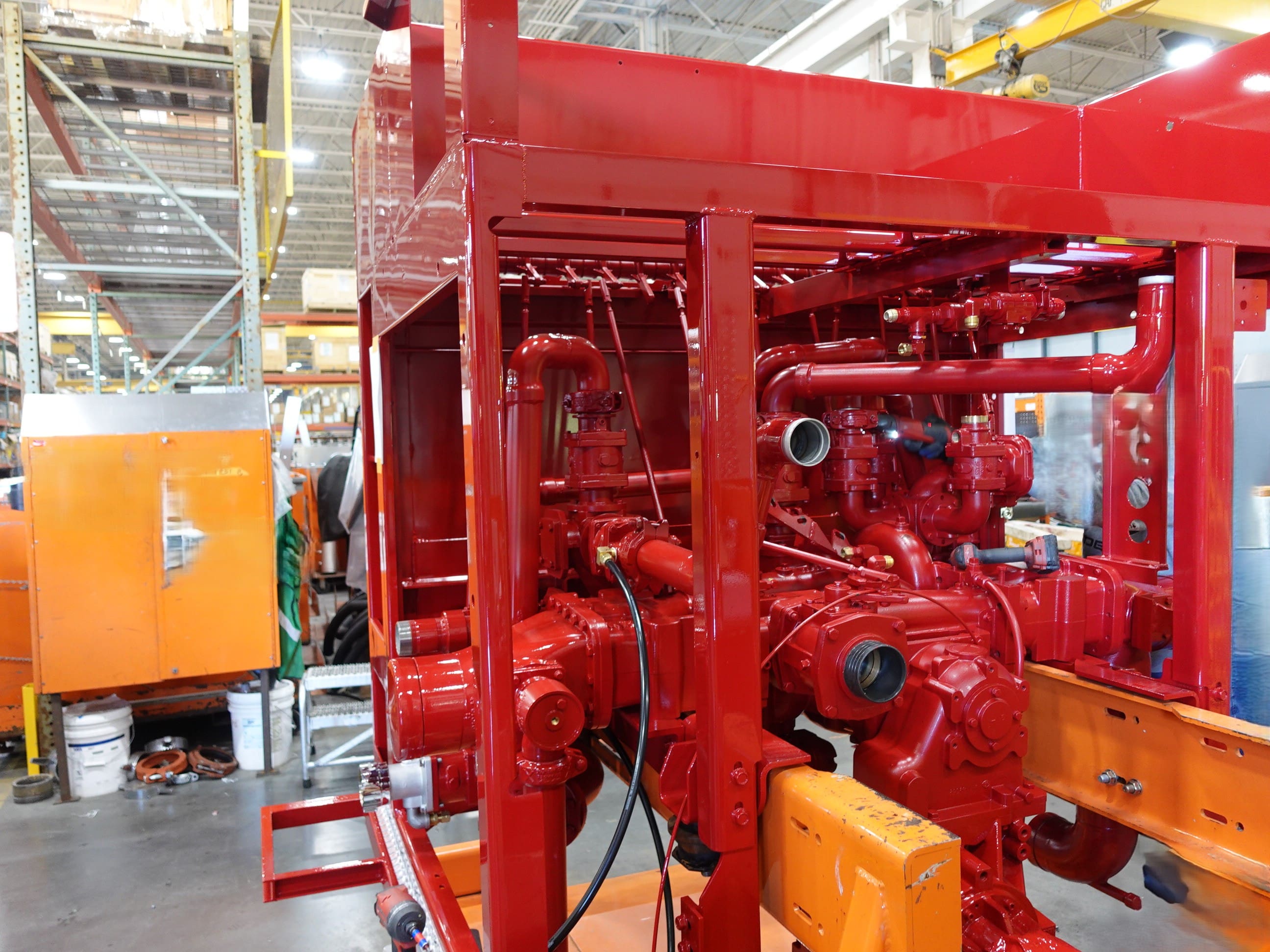

08-07-26

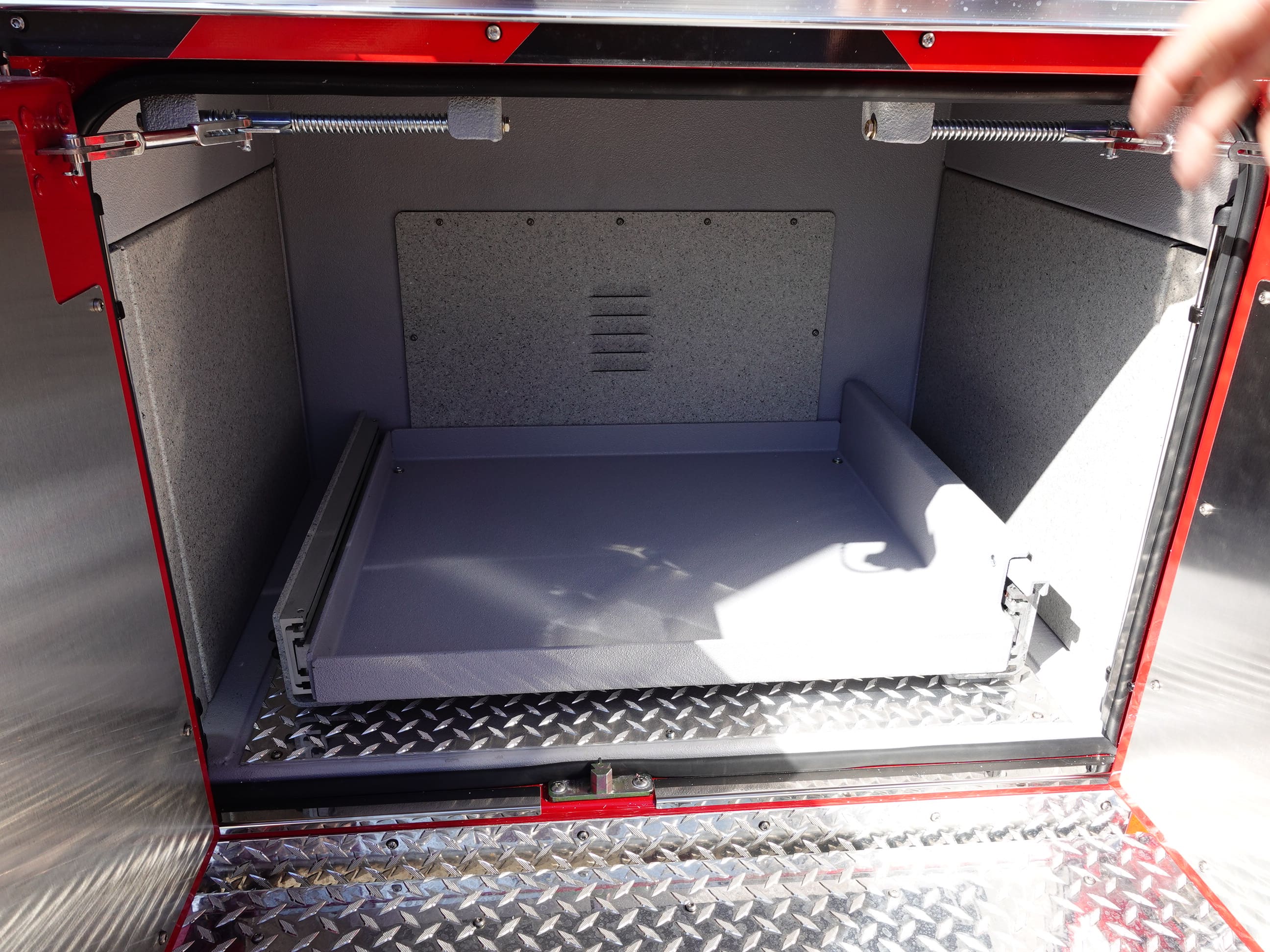

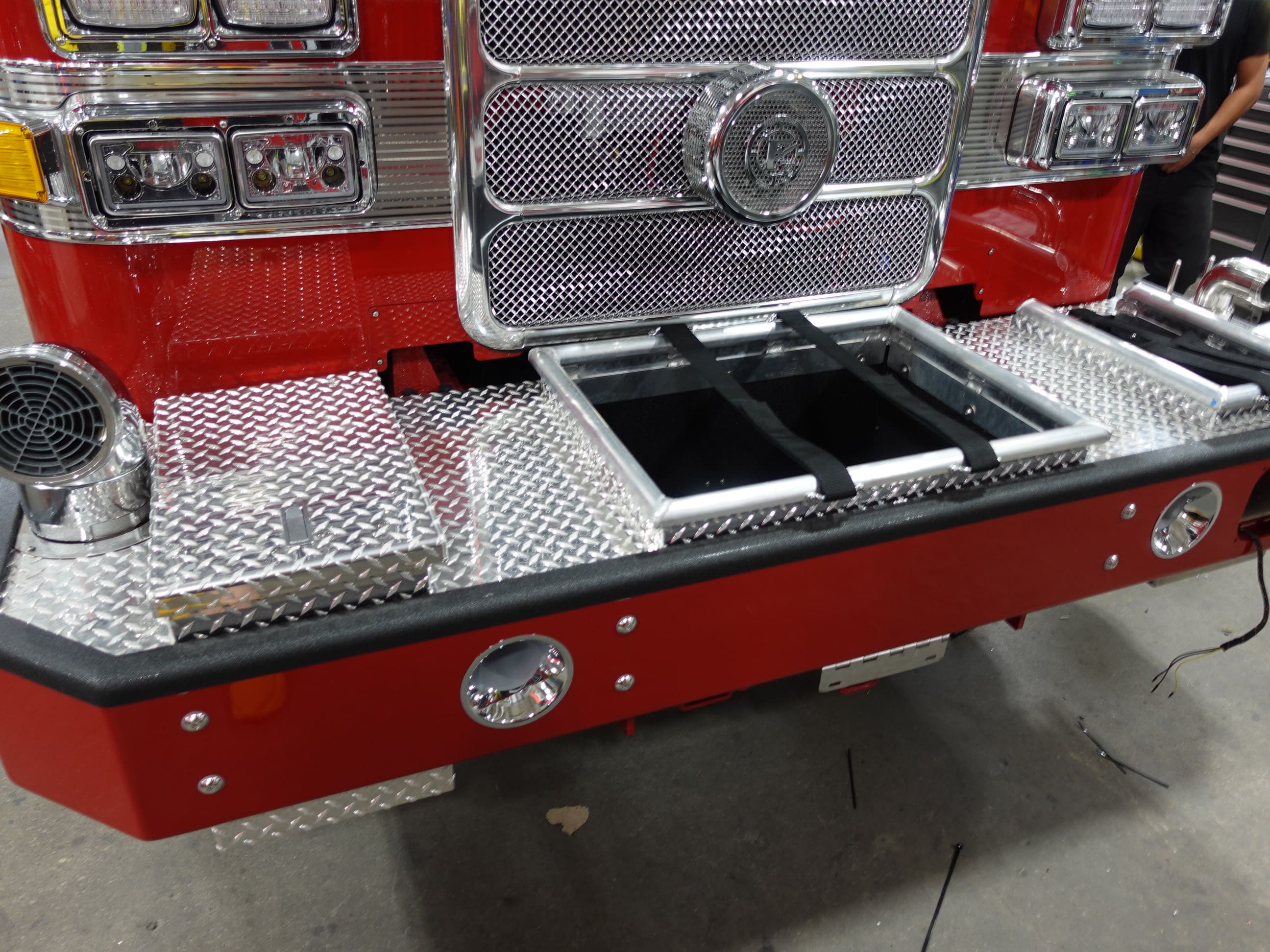

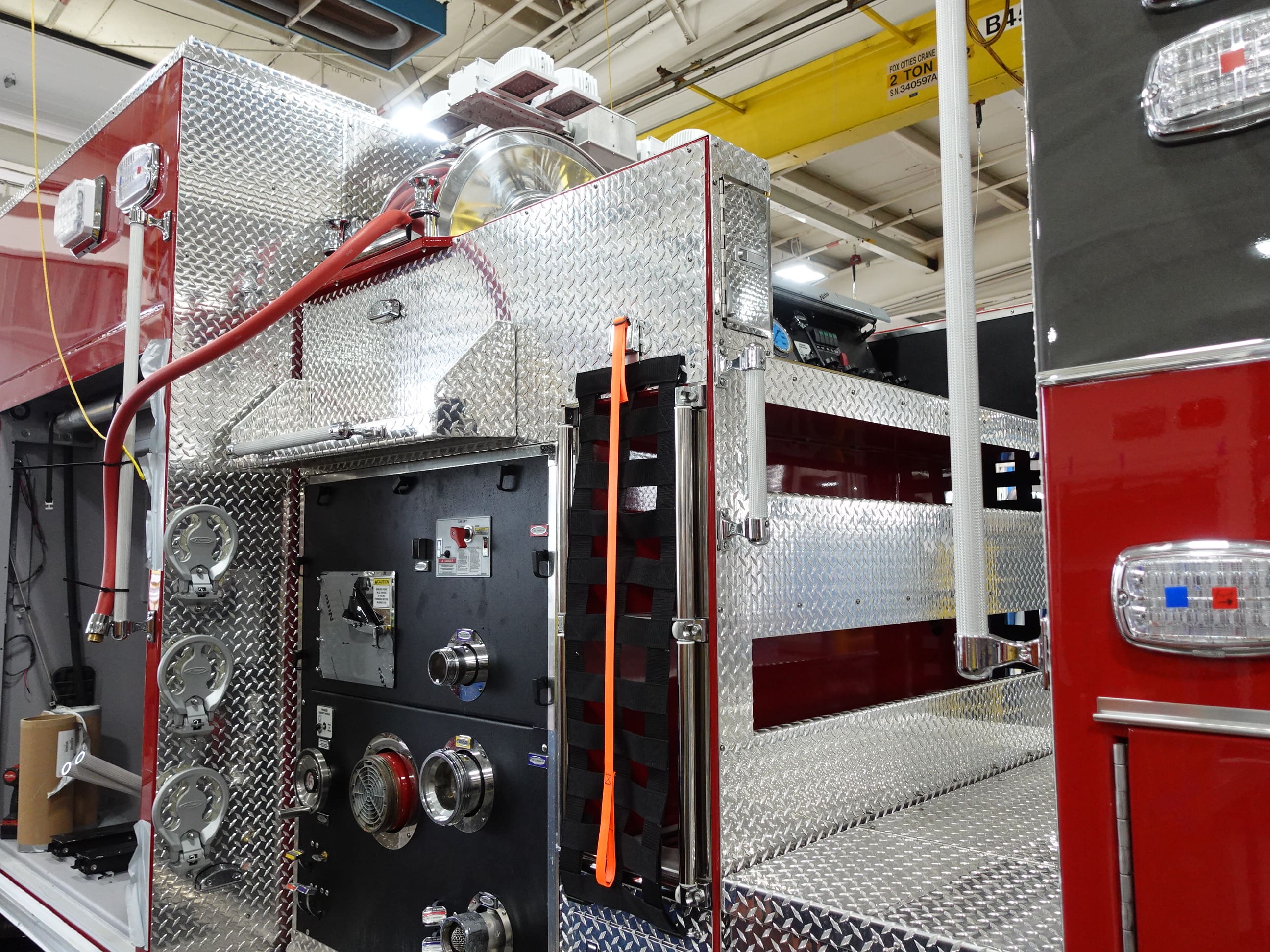

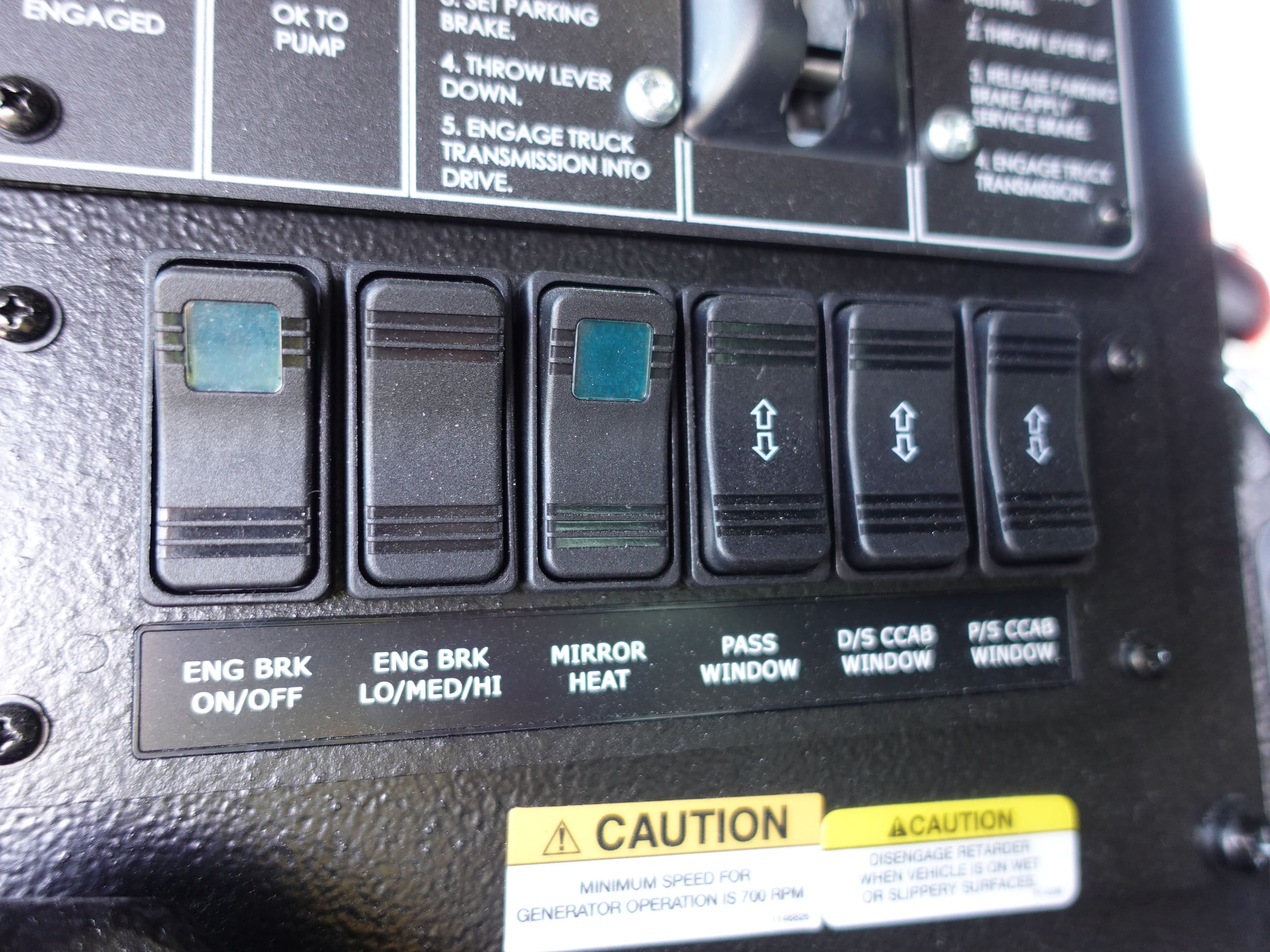

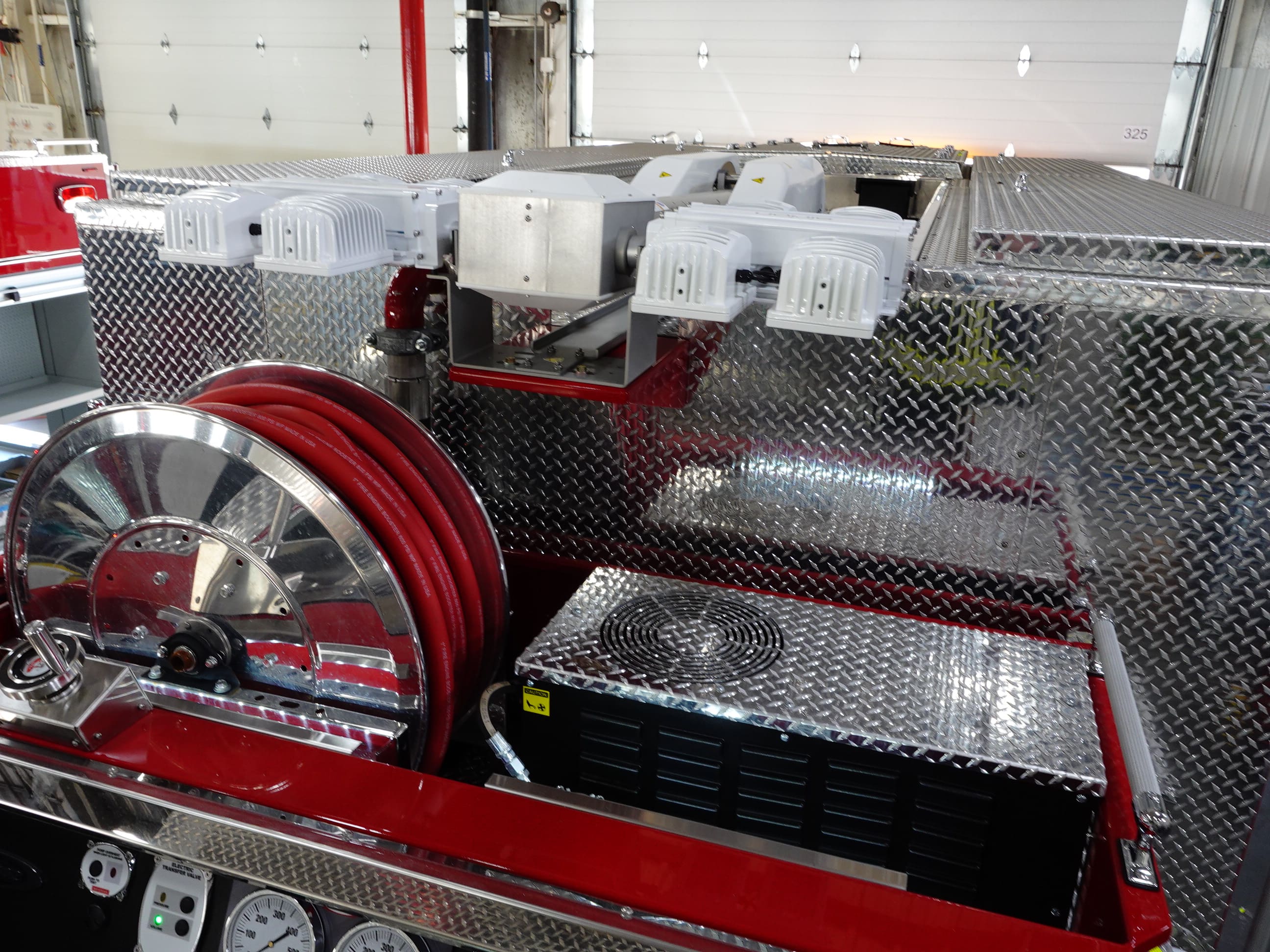

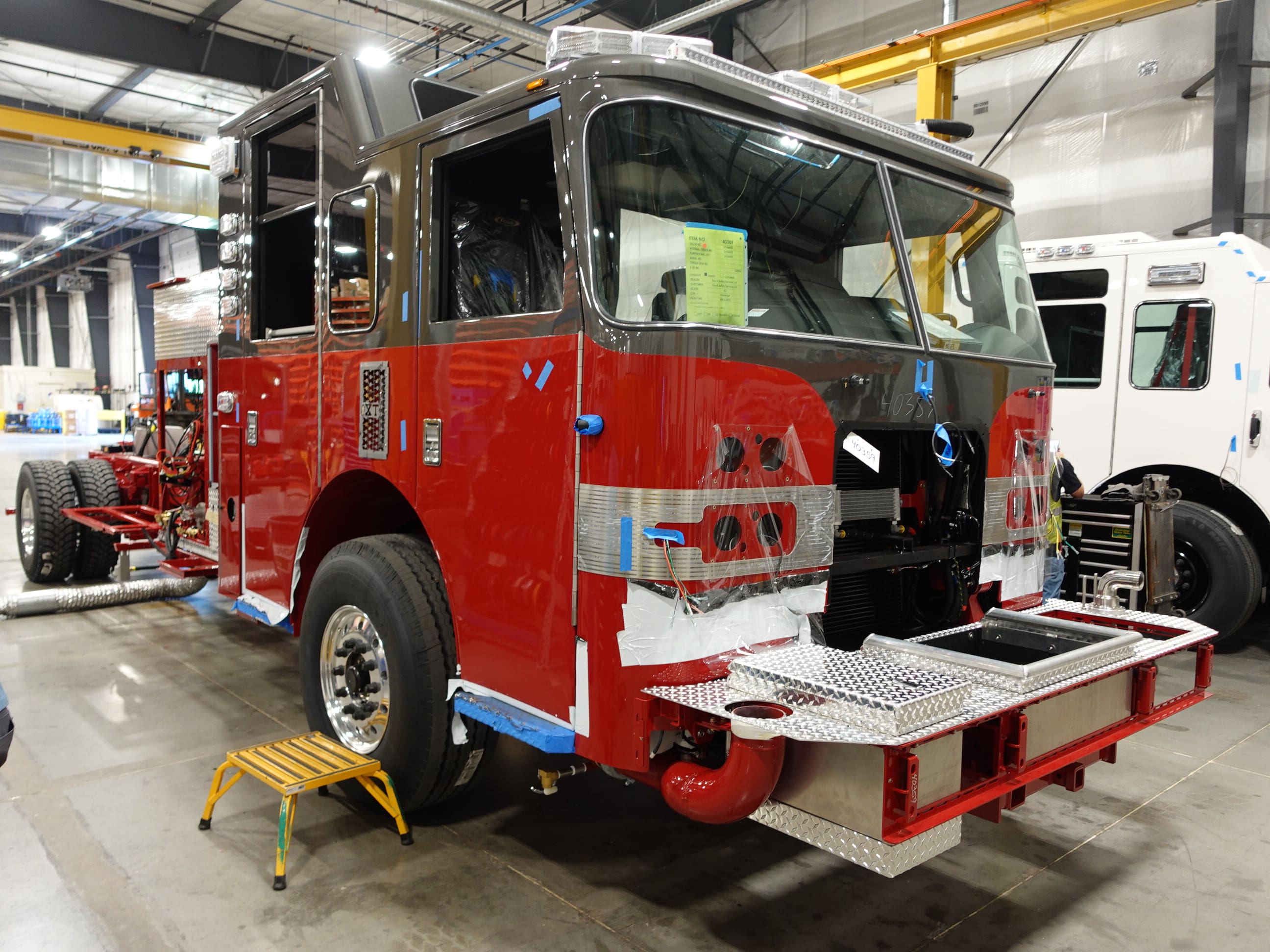

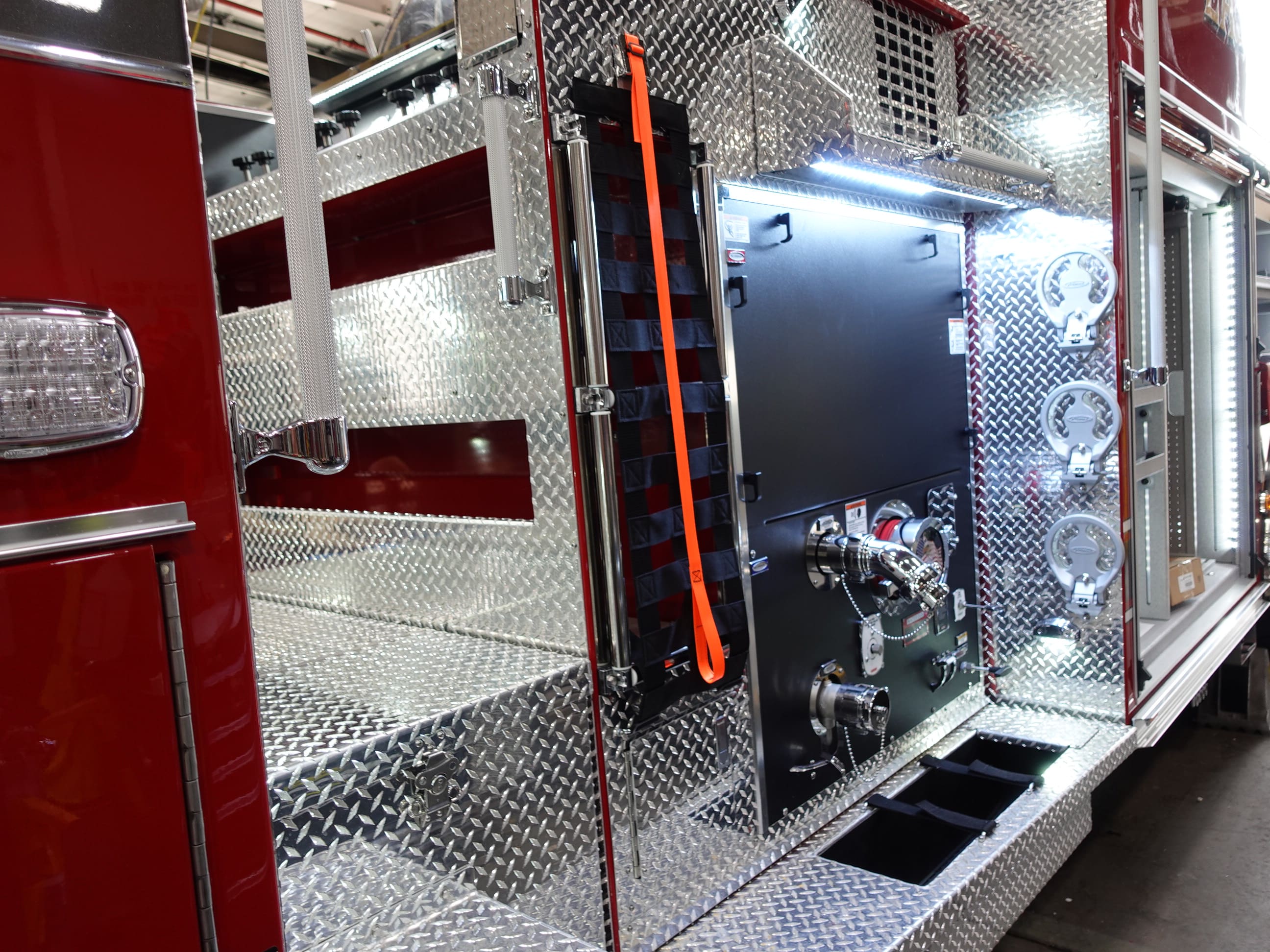

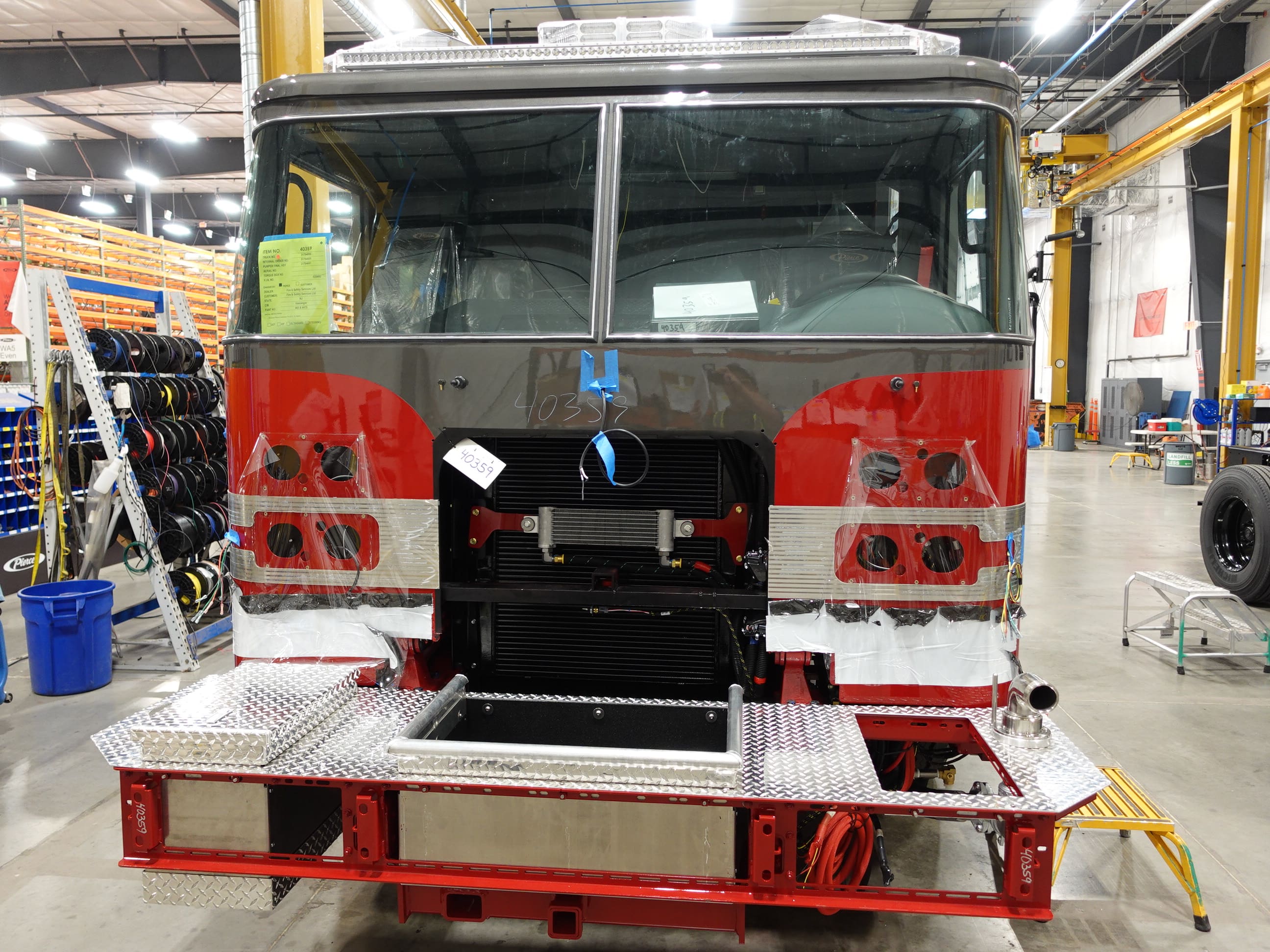

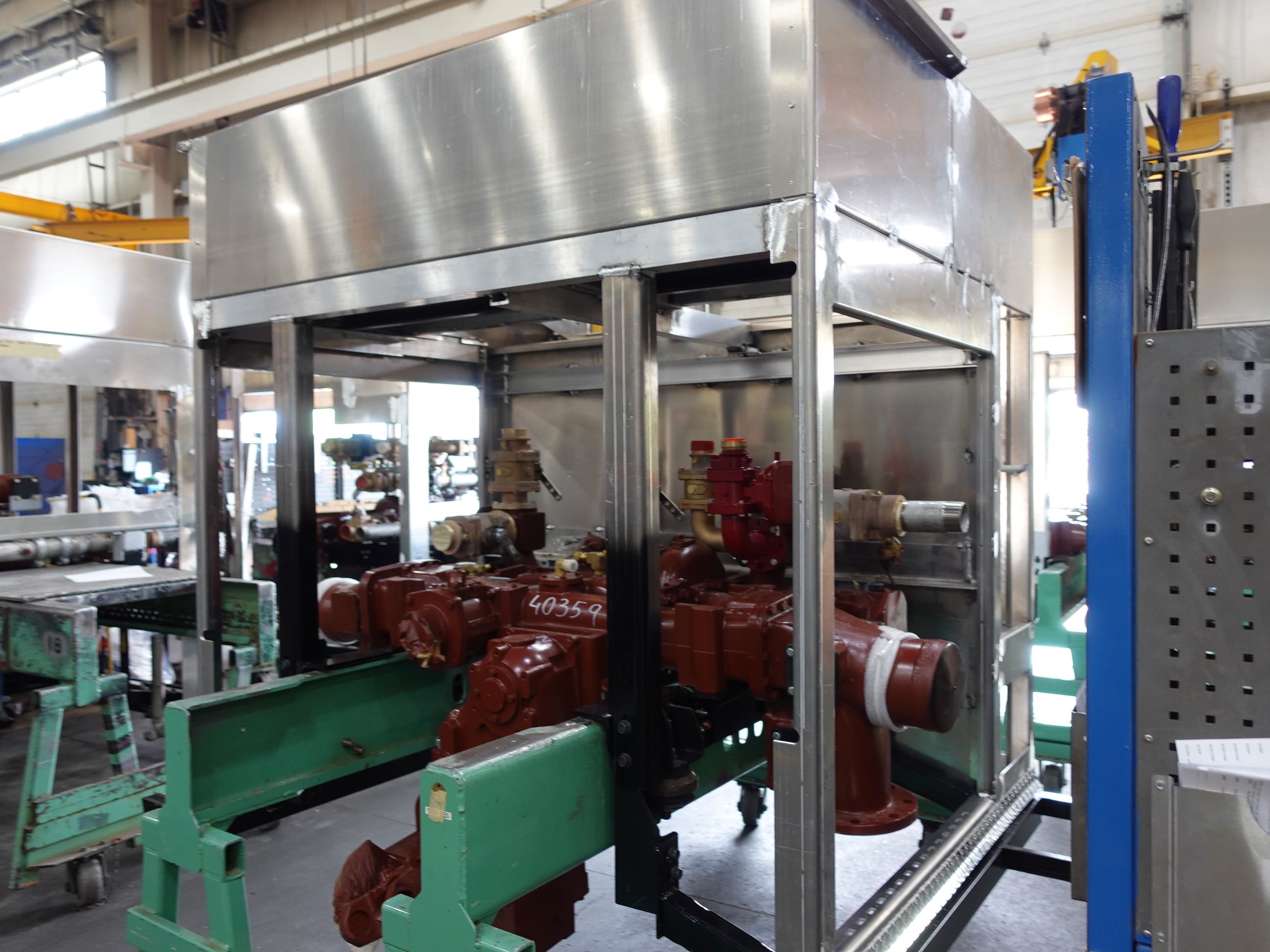

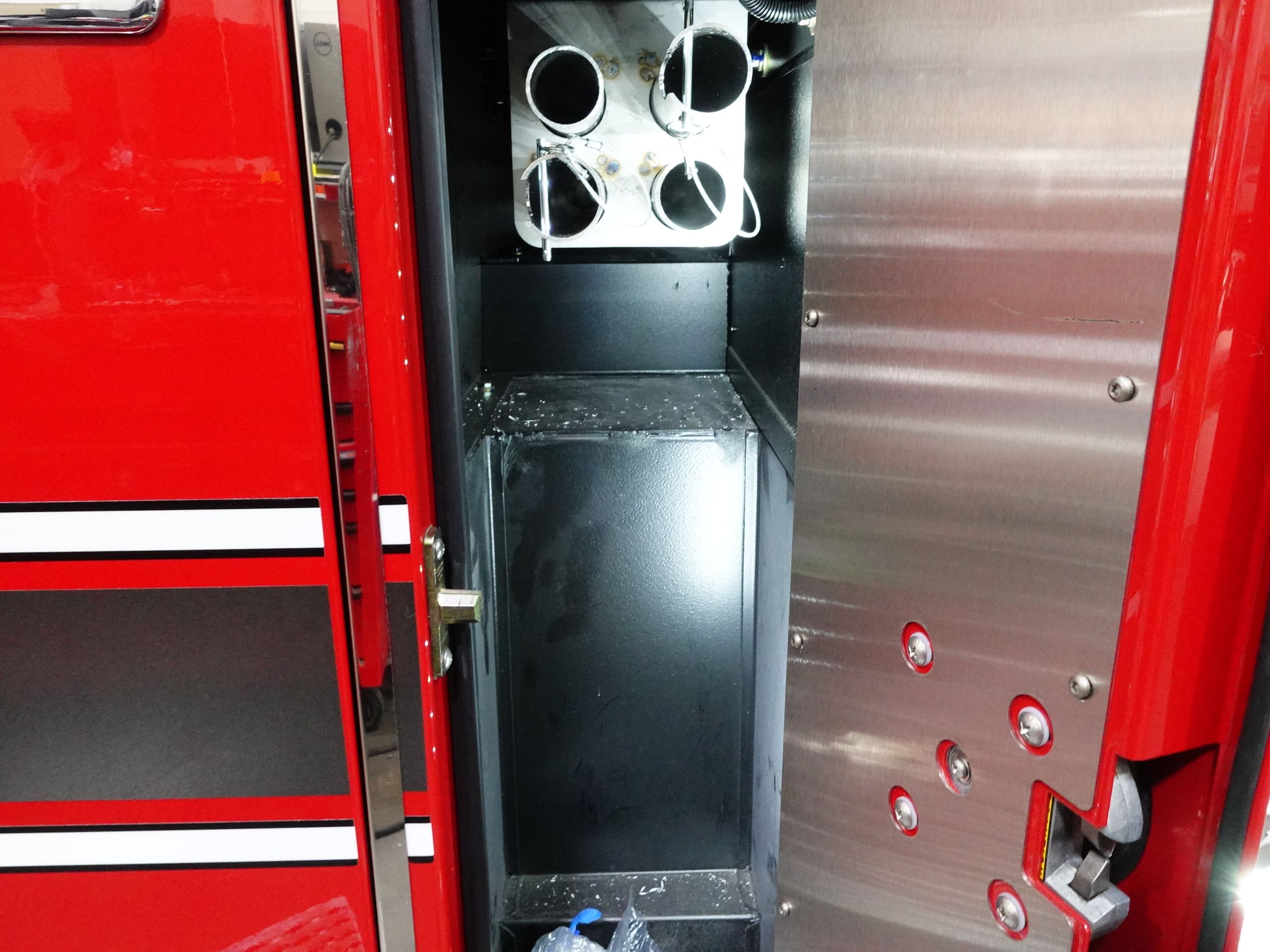

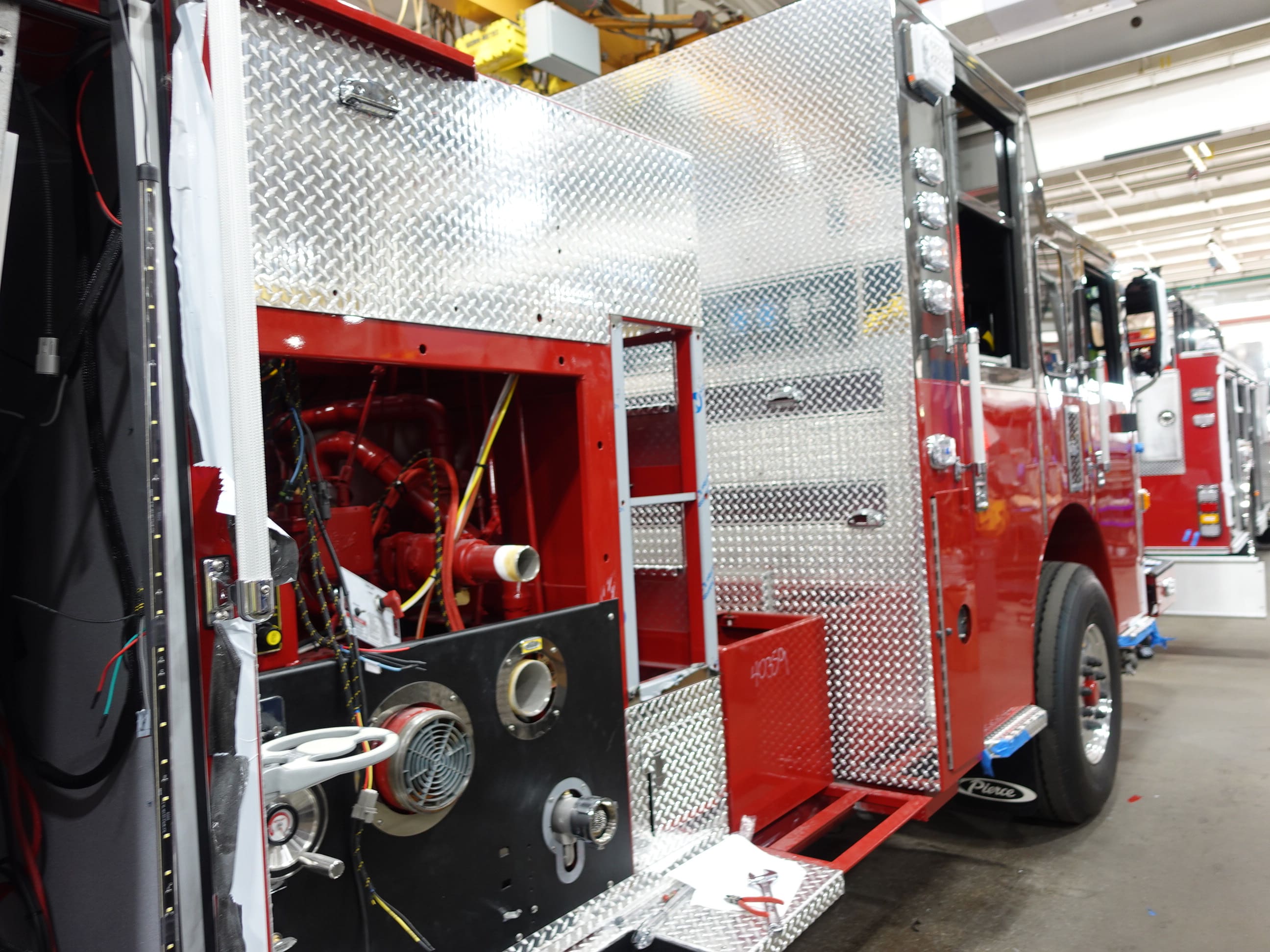

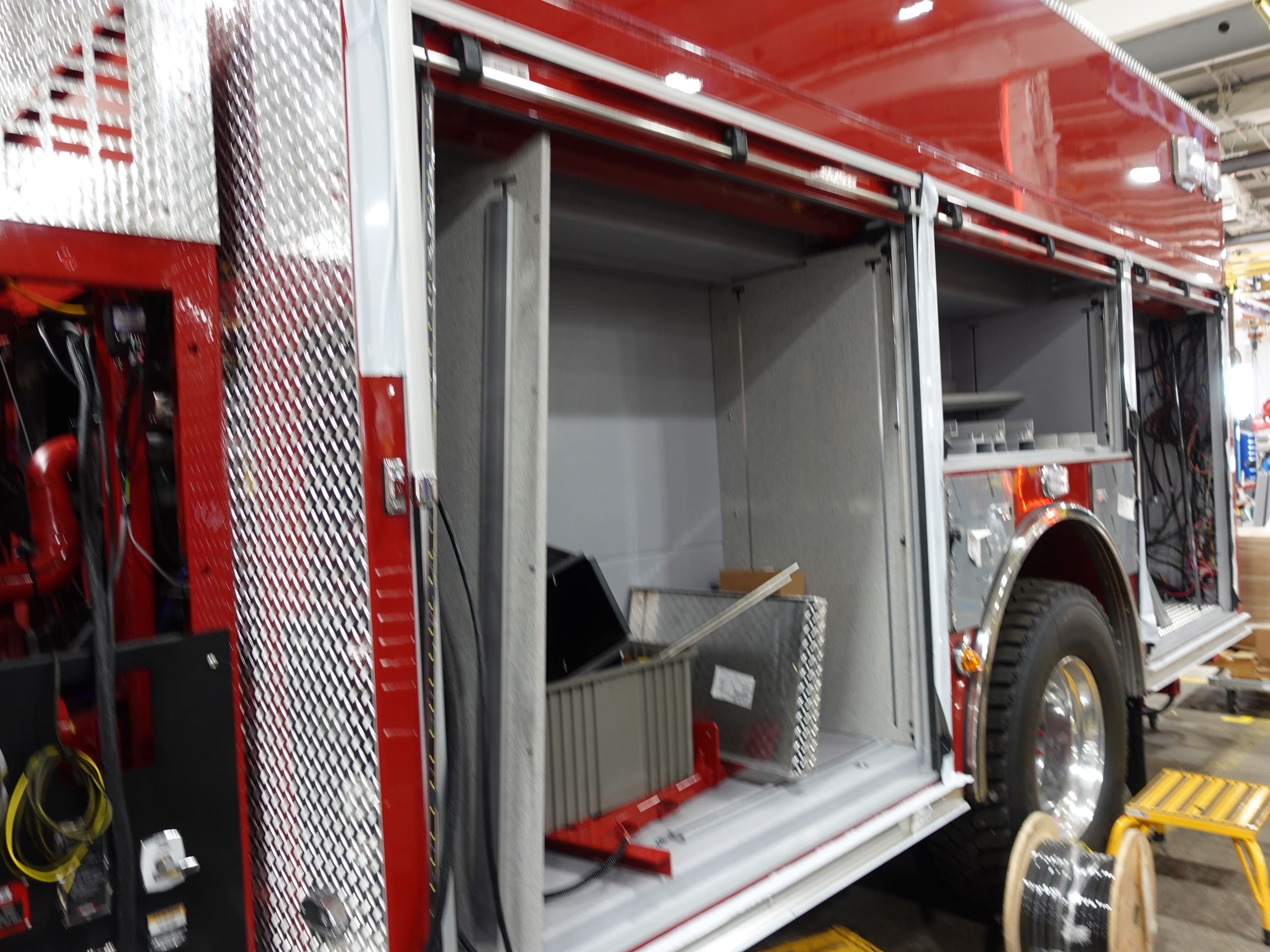

In this report, the apparatus completed testing then released to quality and graphics where any remaining content will be applied.

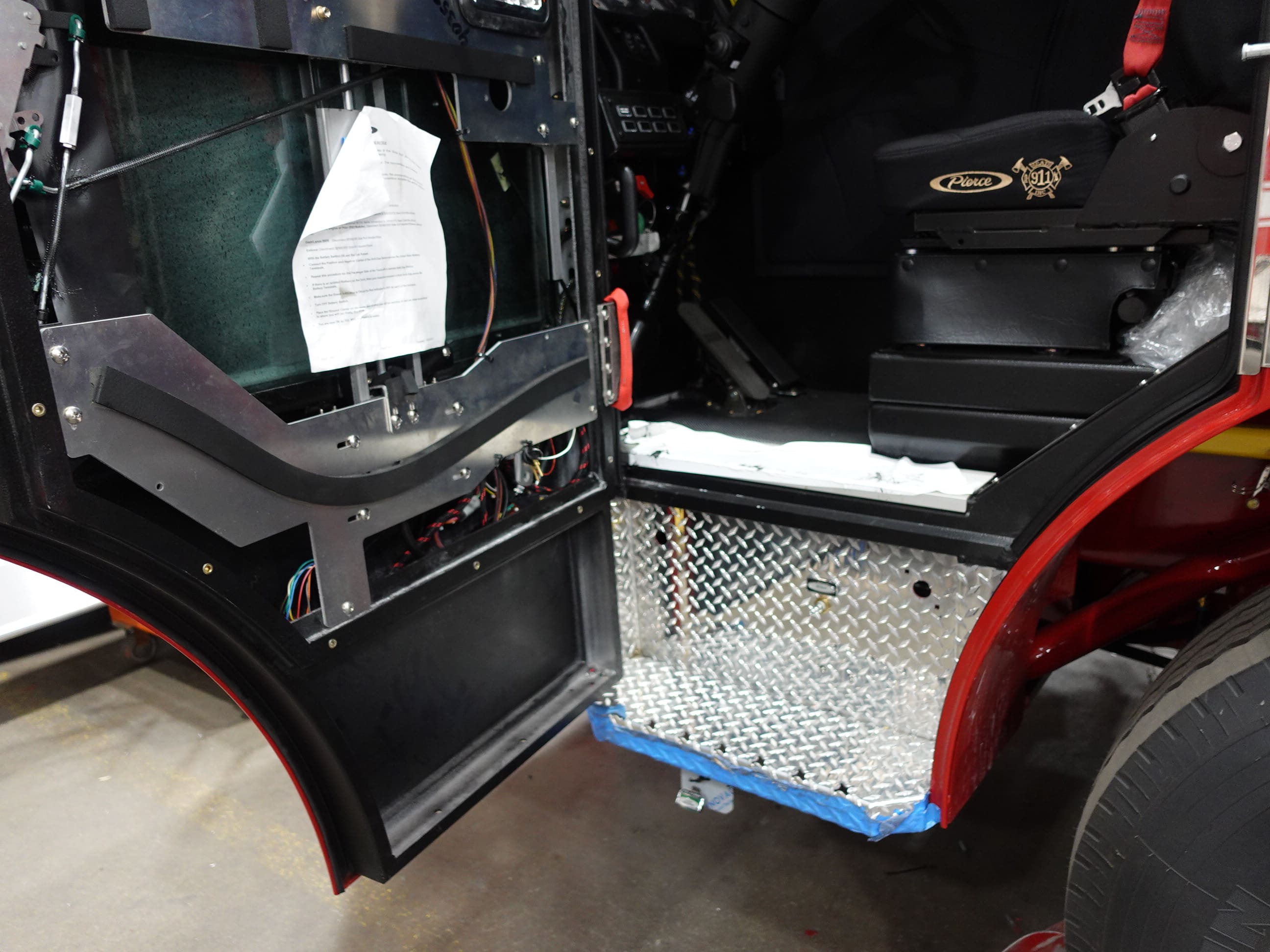

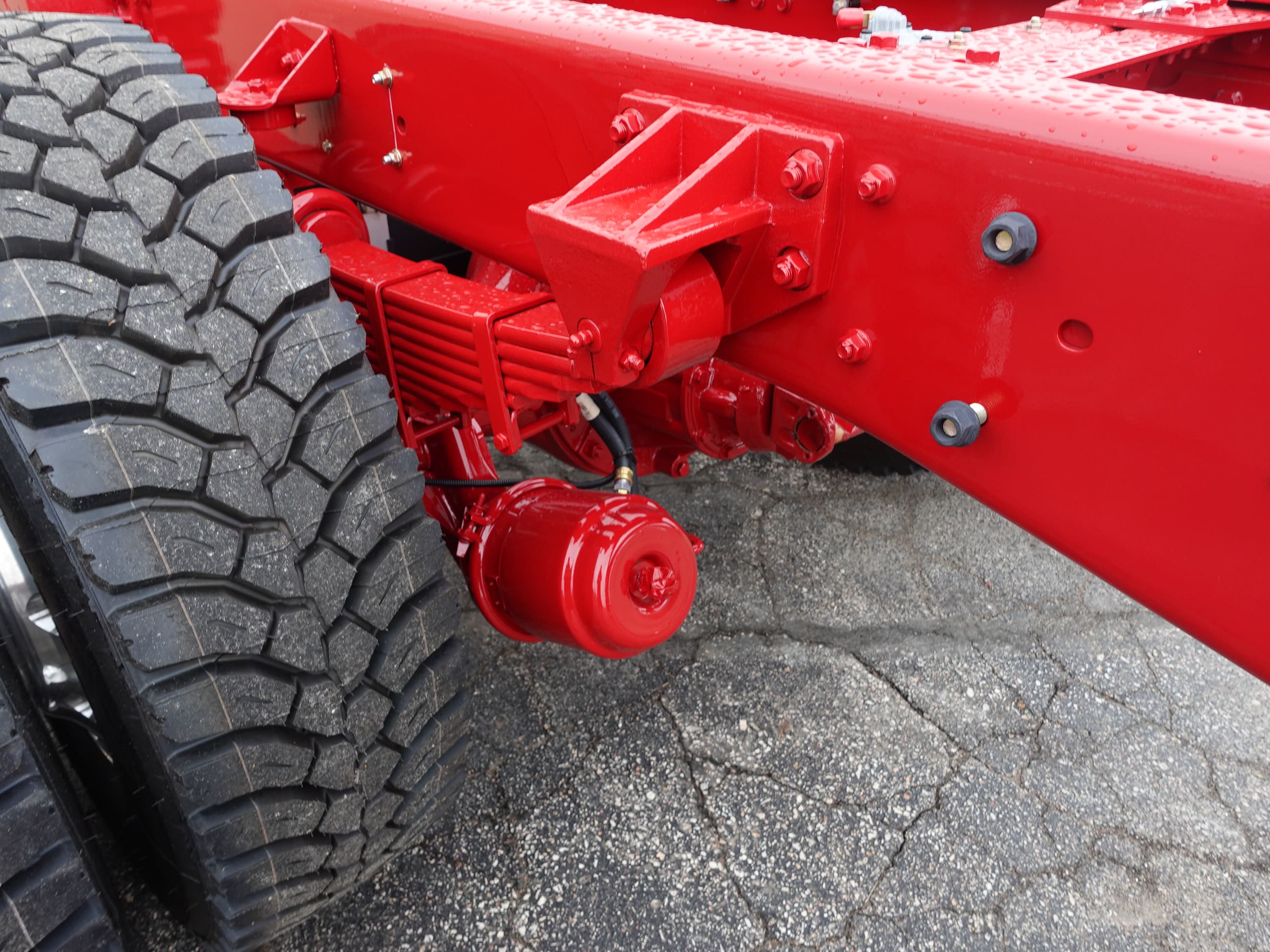

06-26-26

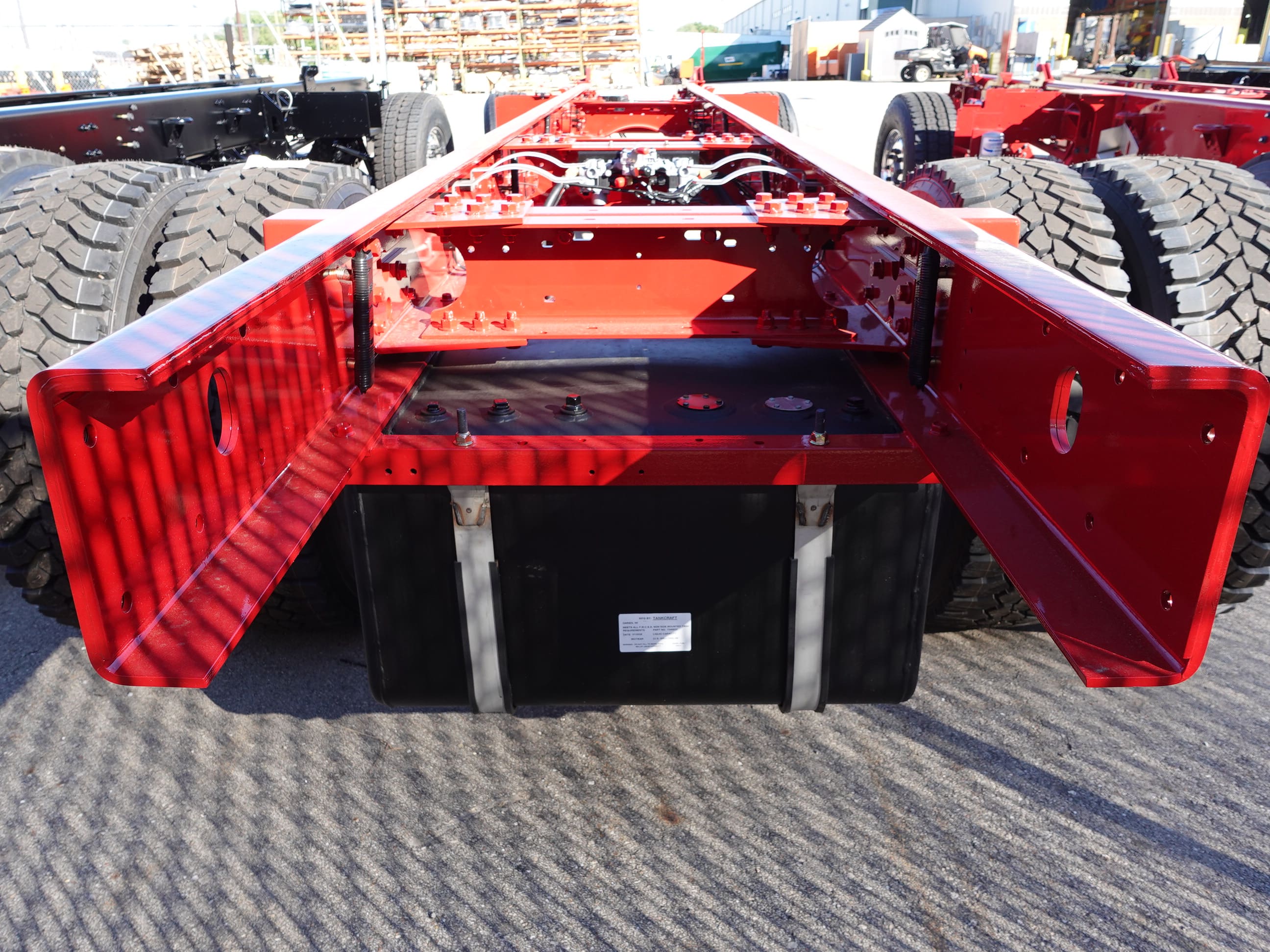

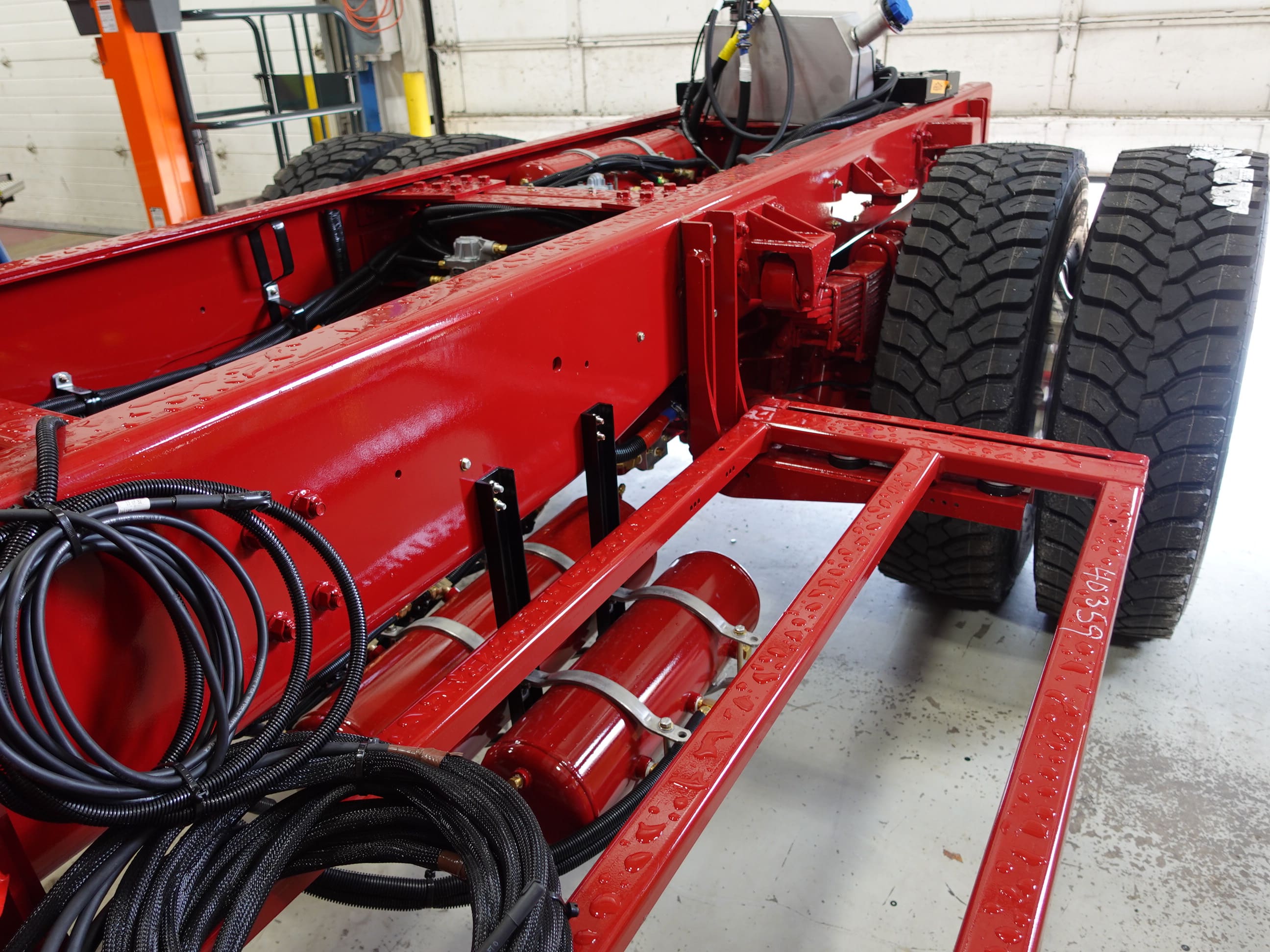

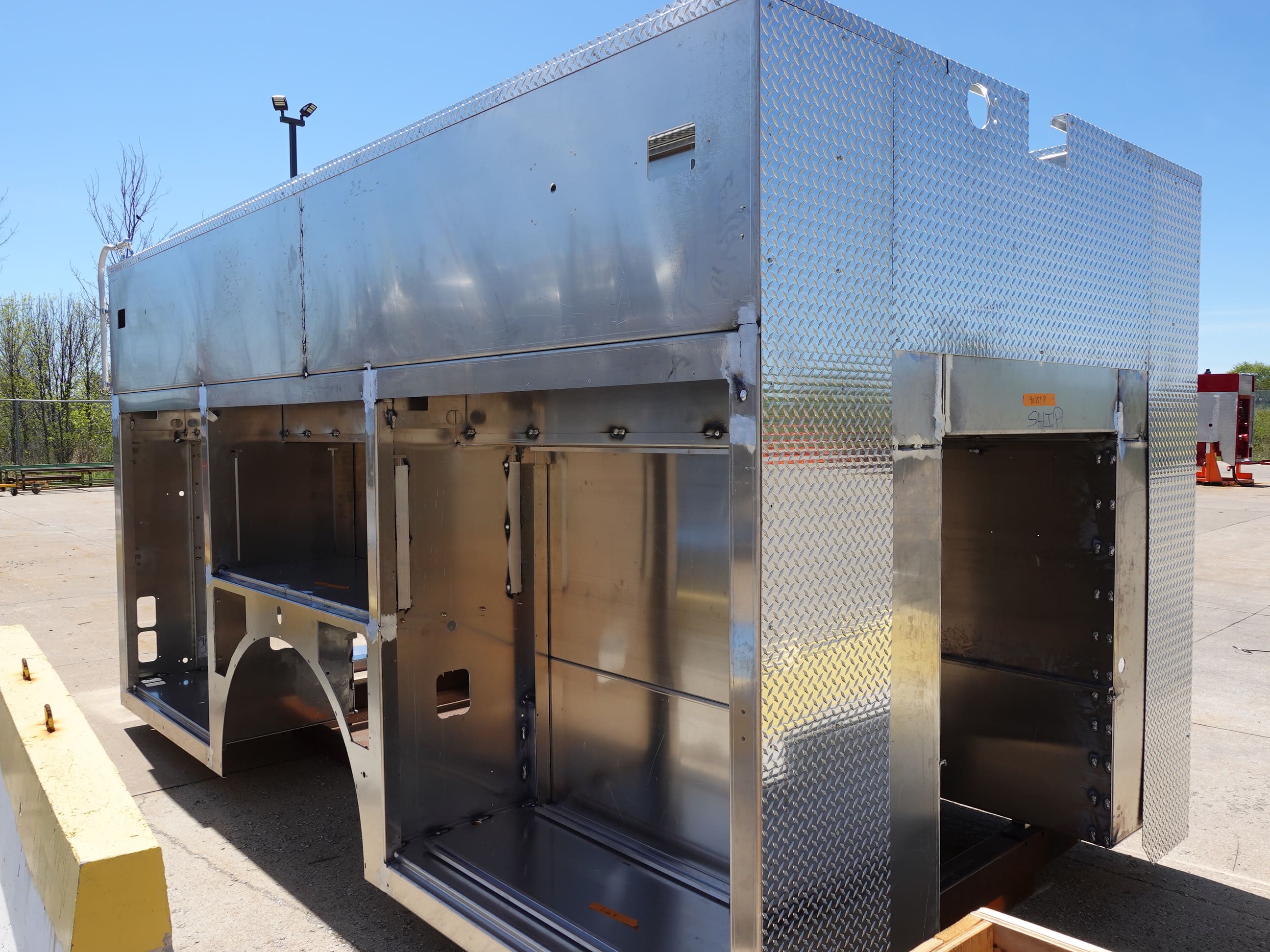

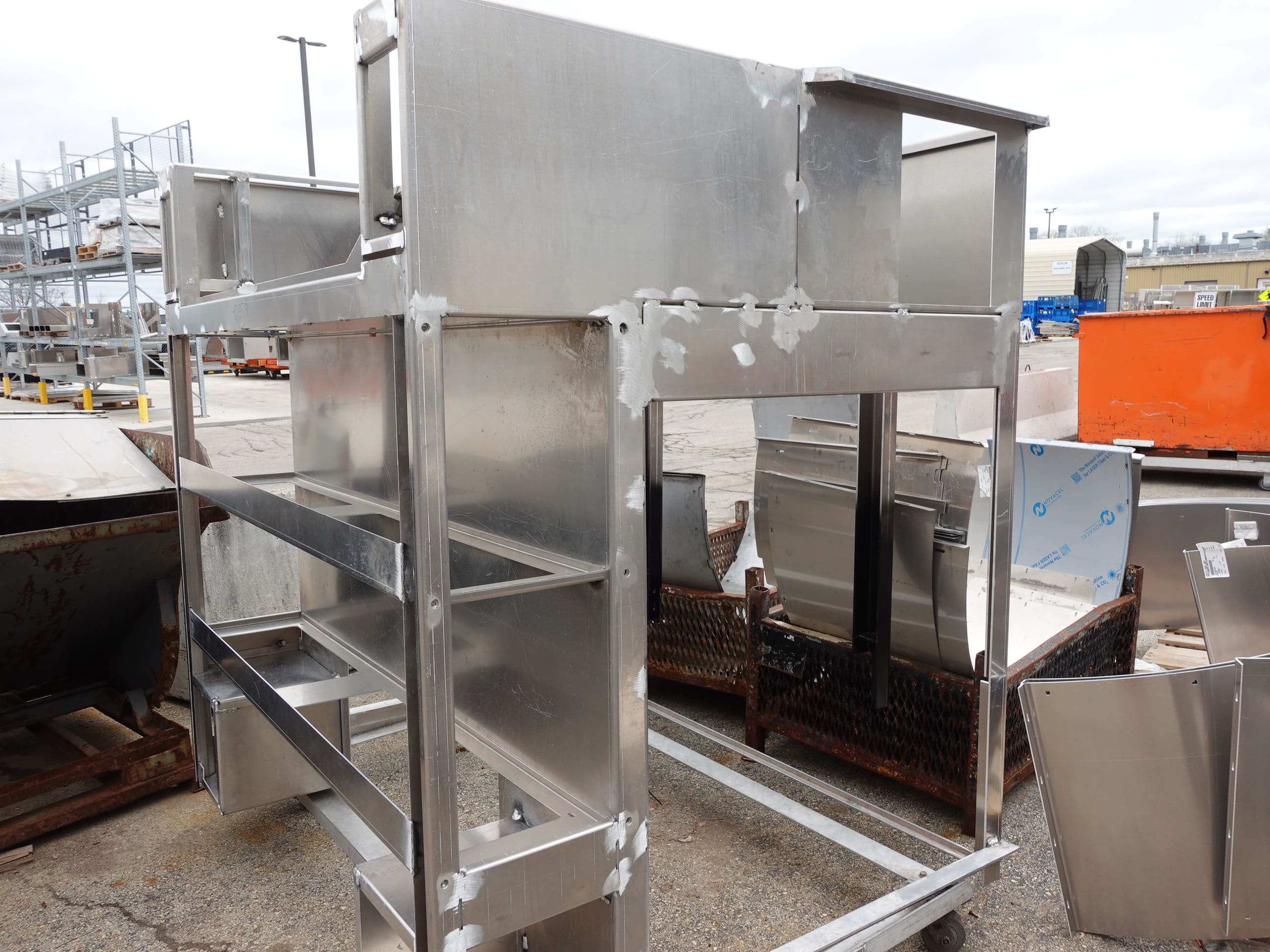

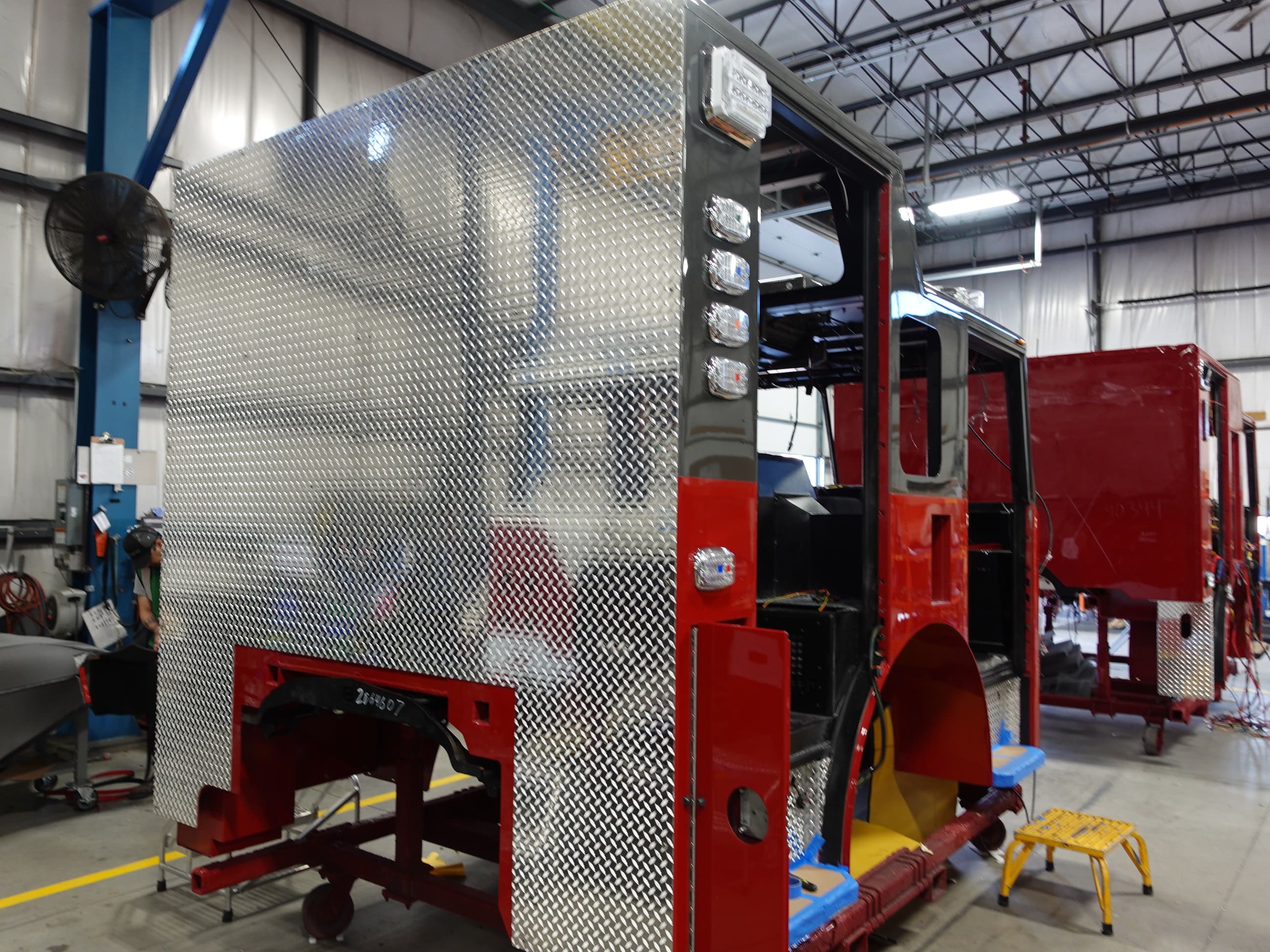

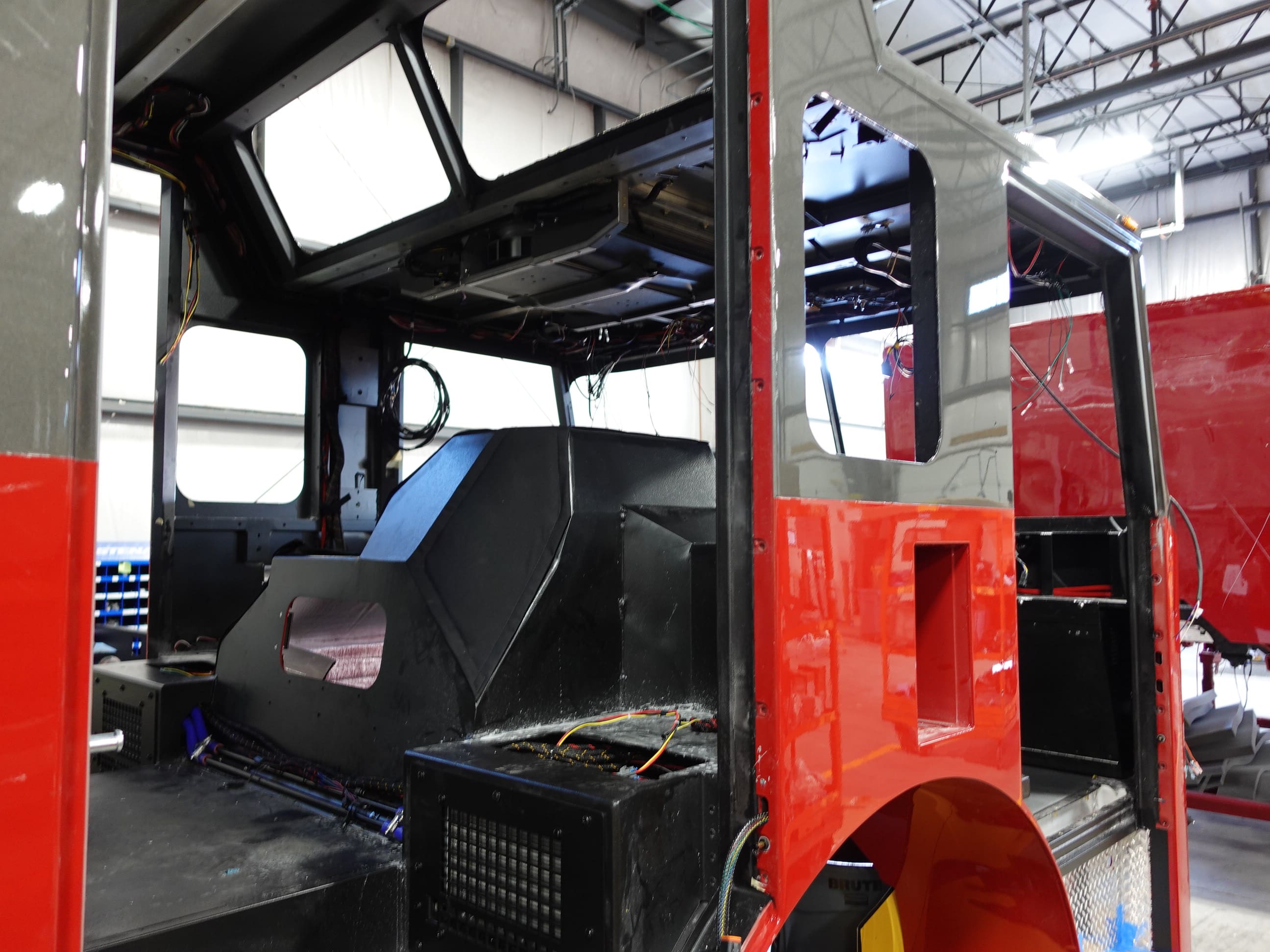

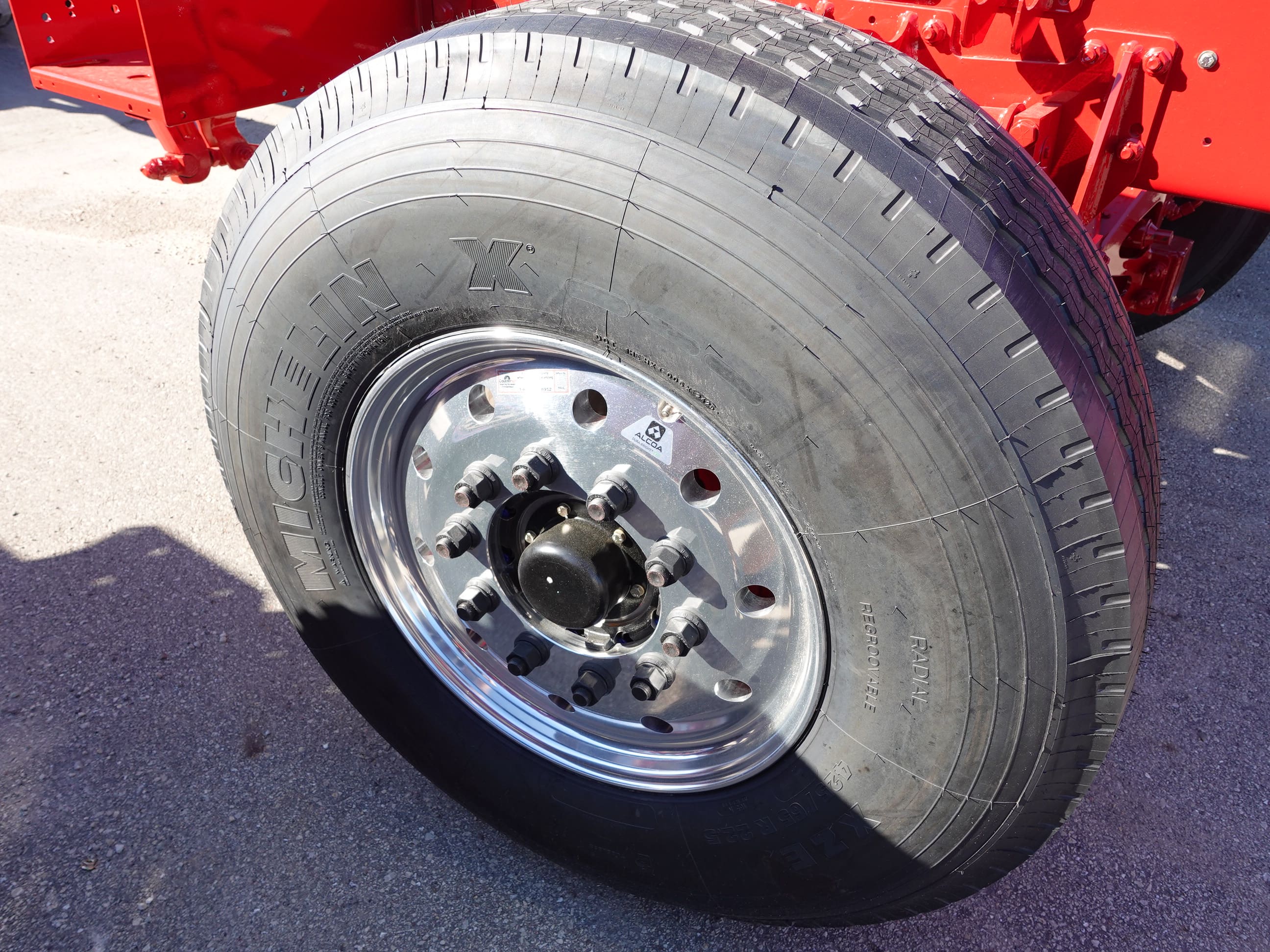

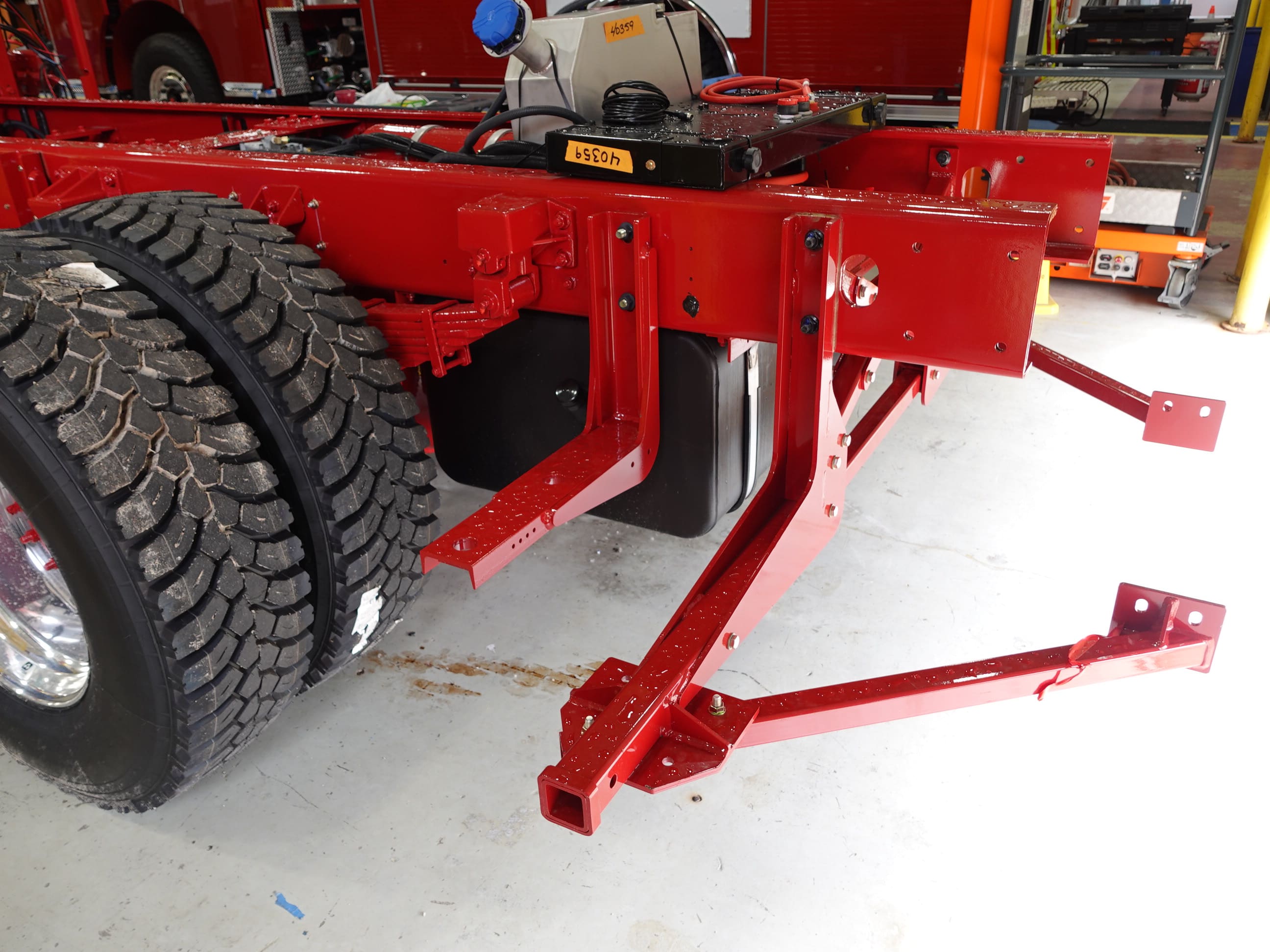

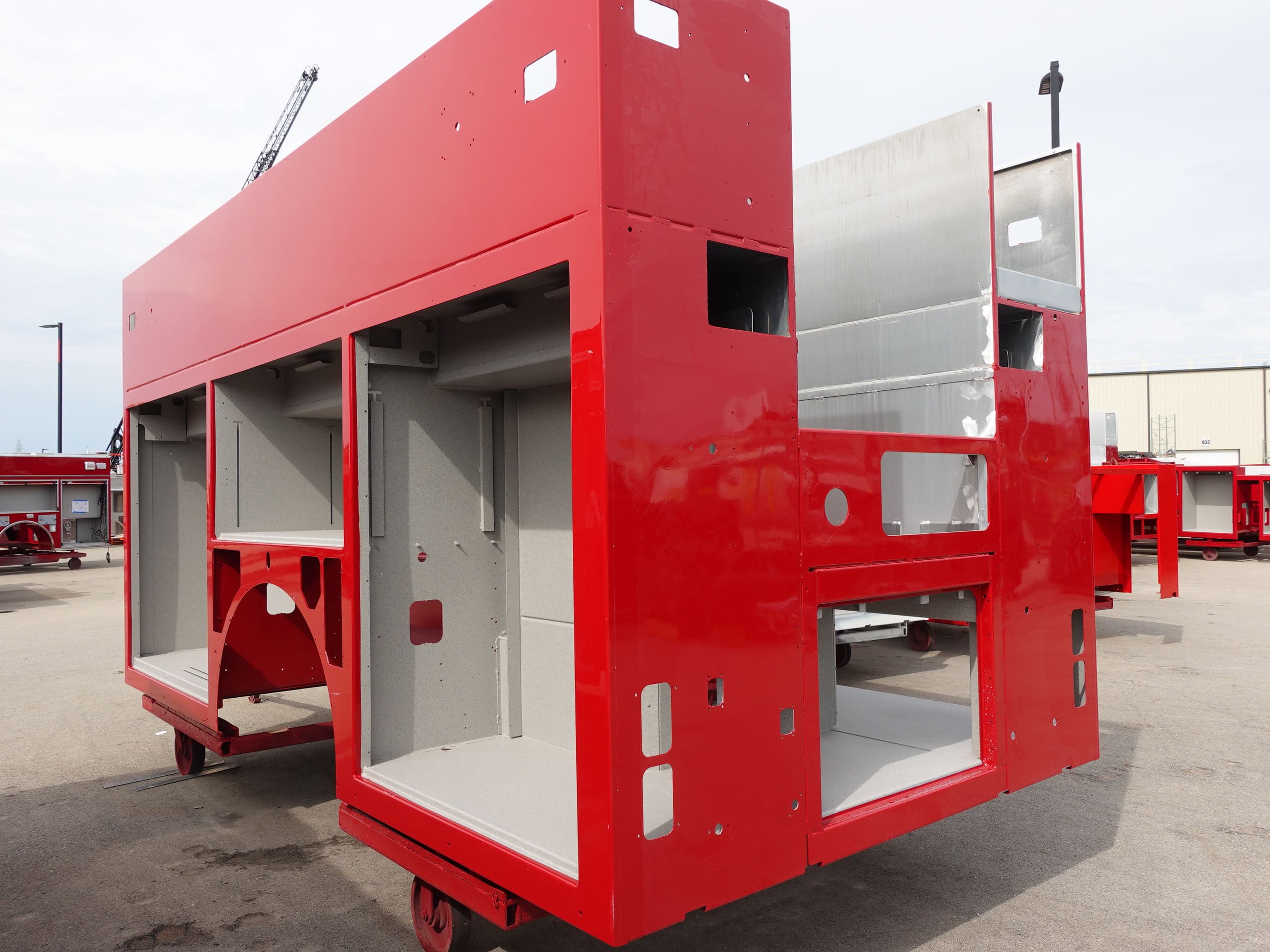

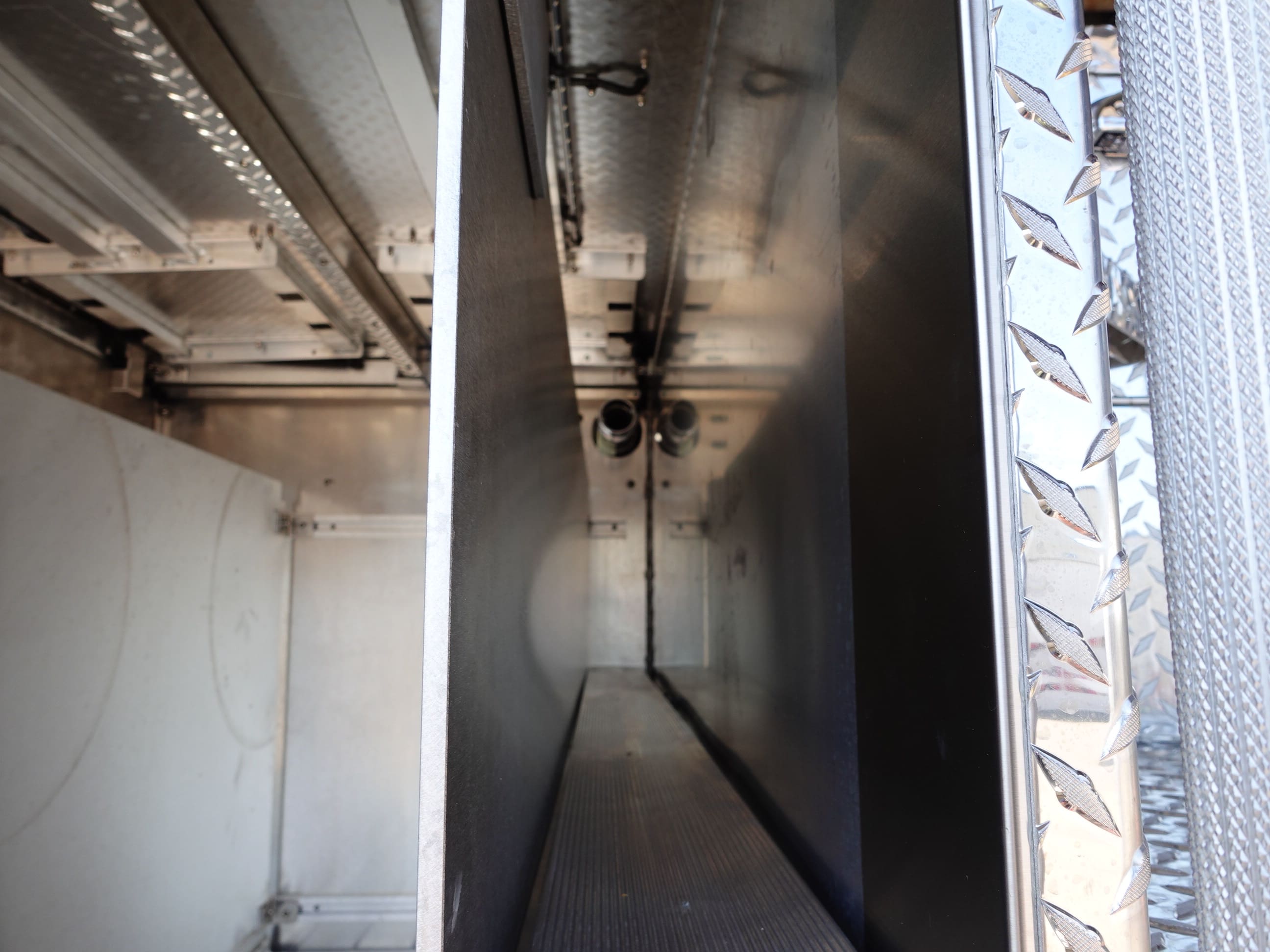

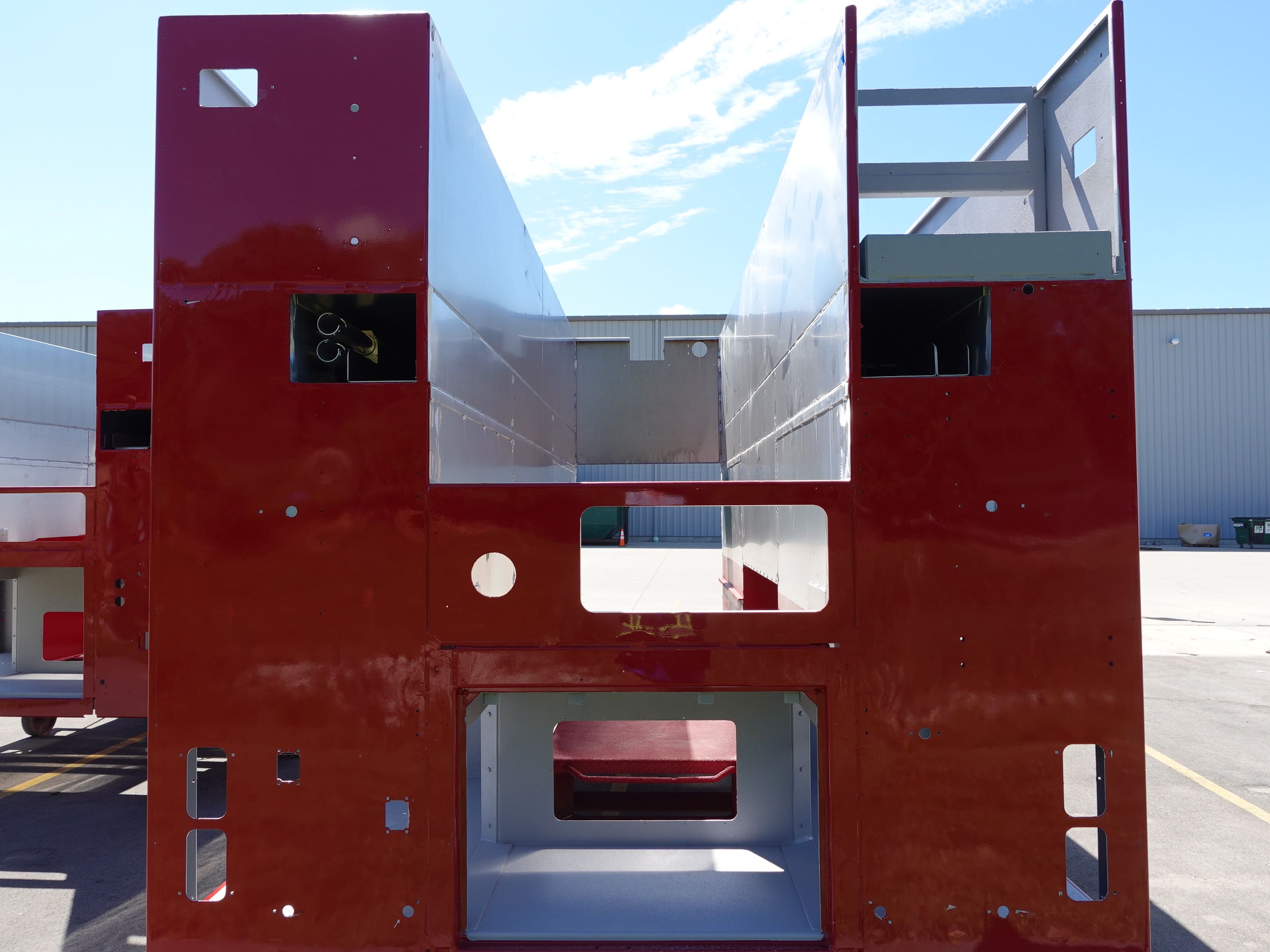

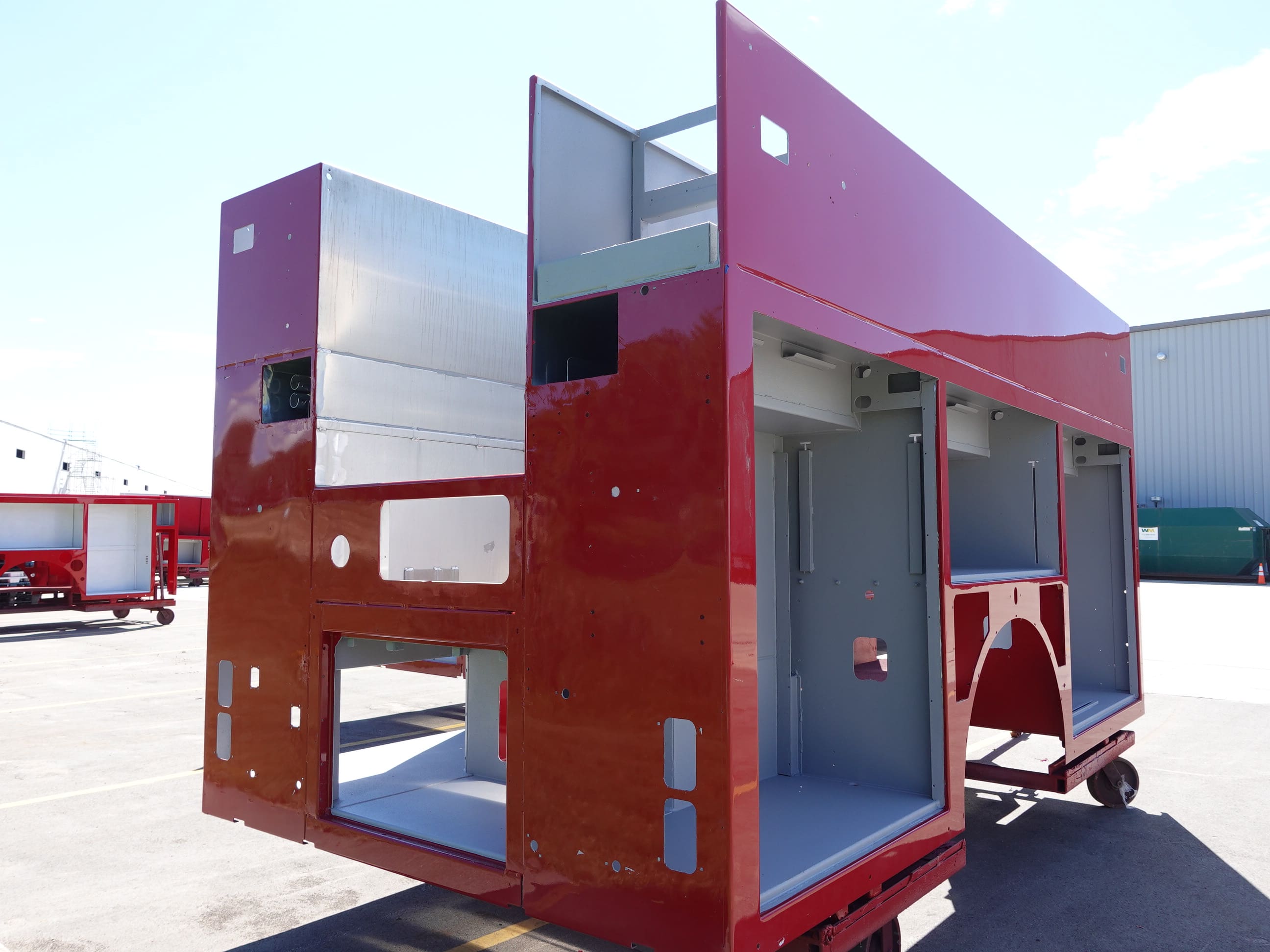

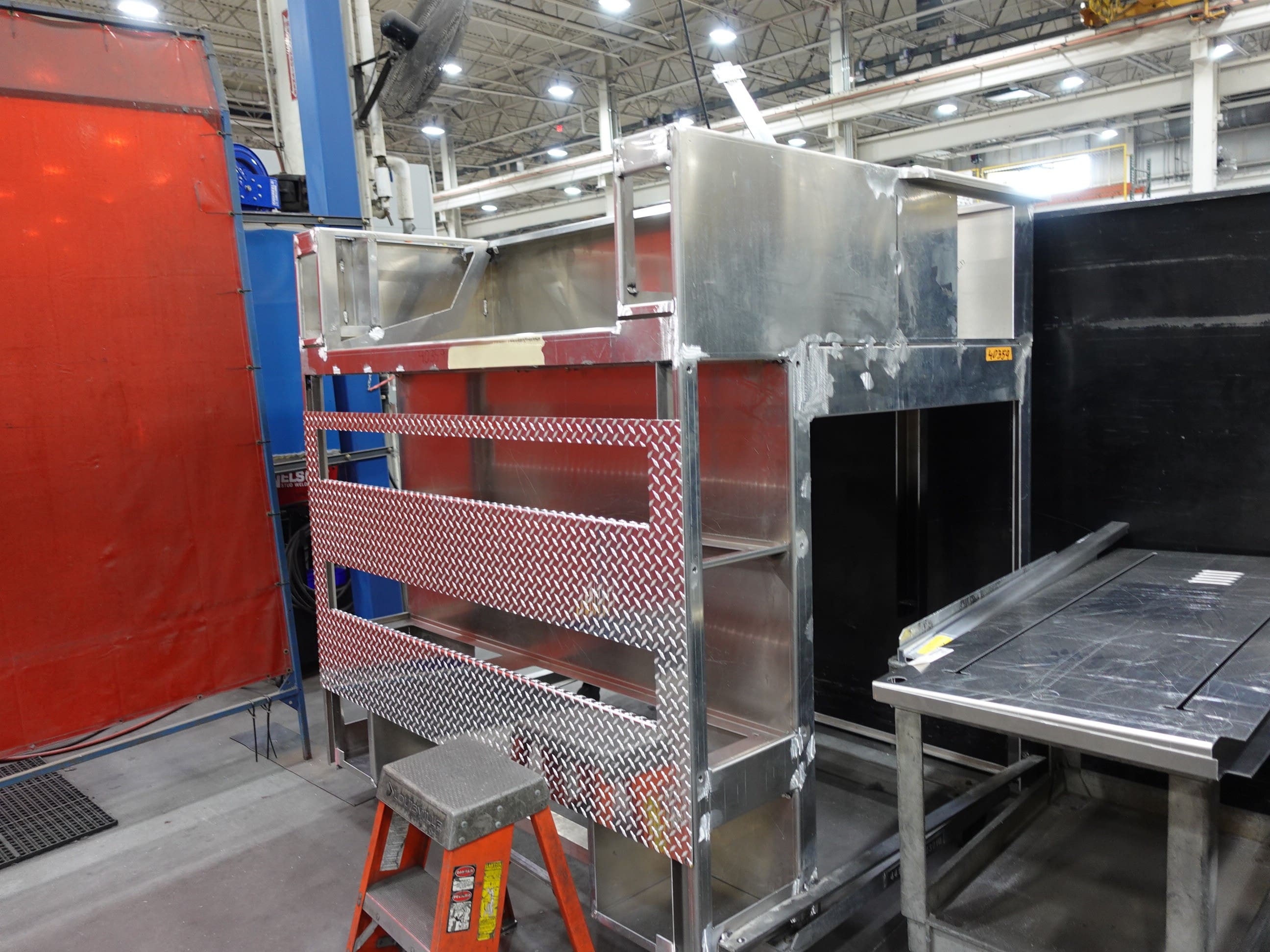

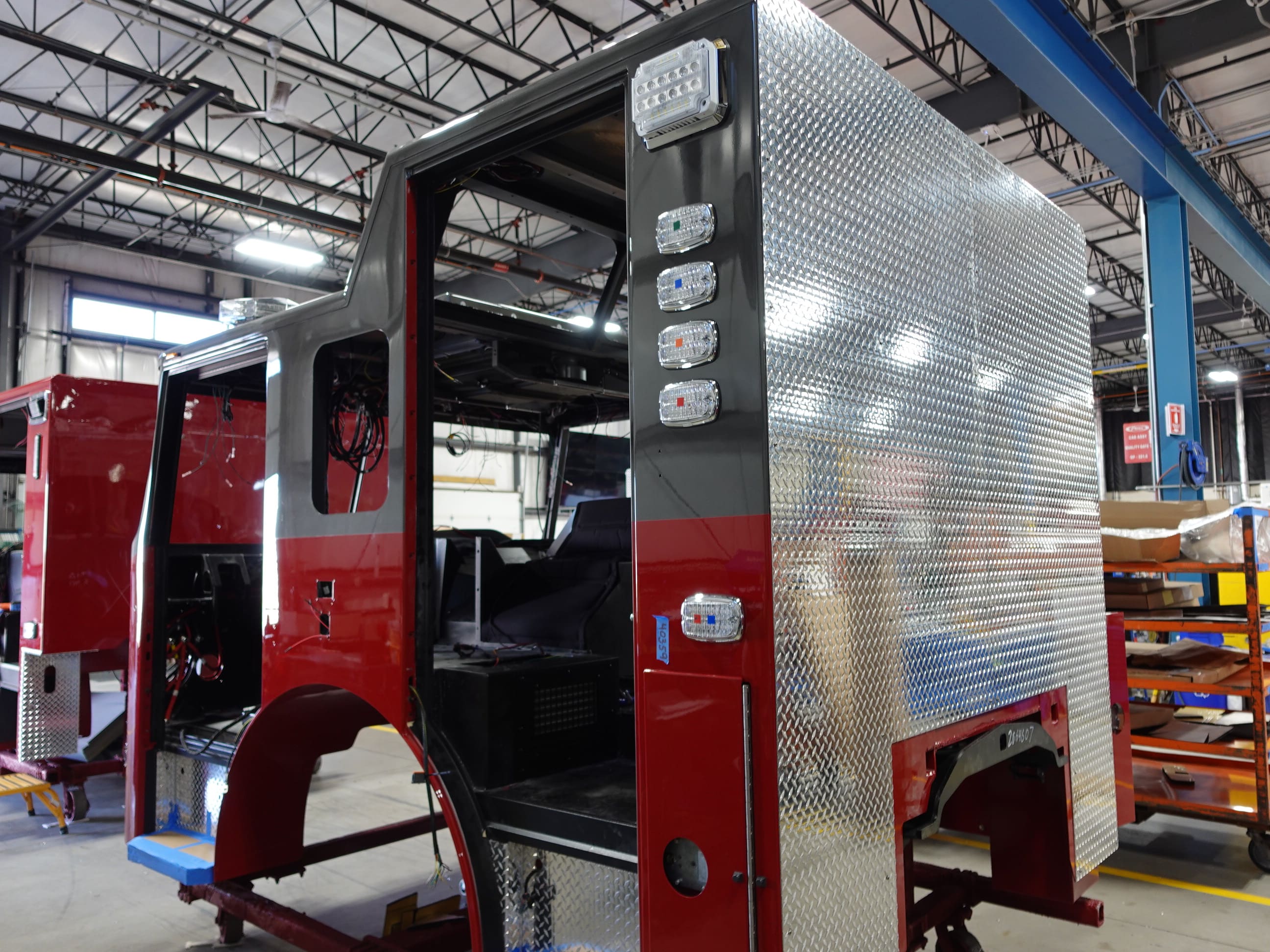

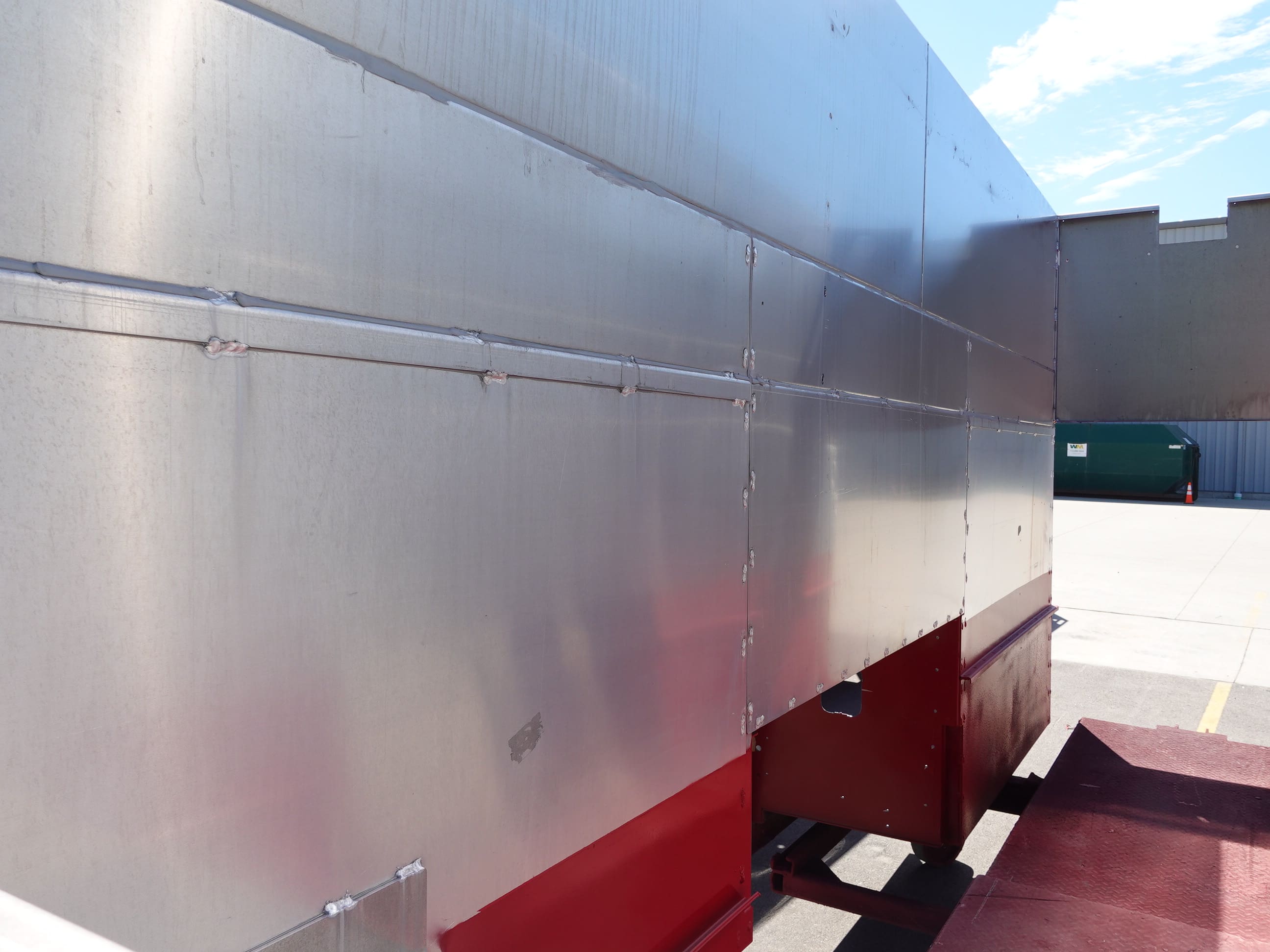

In this report, the chassis was staged to continue assembly while the body was staged.
06-19-26

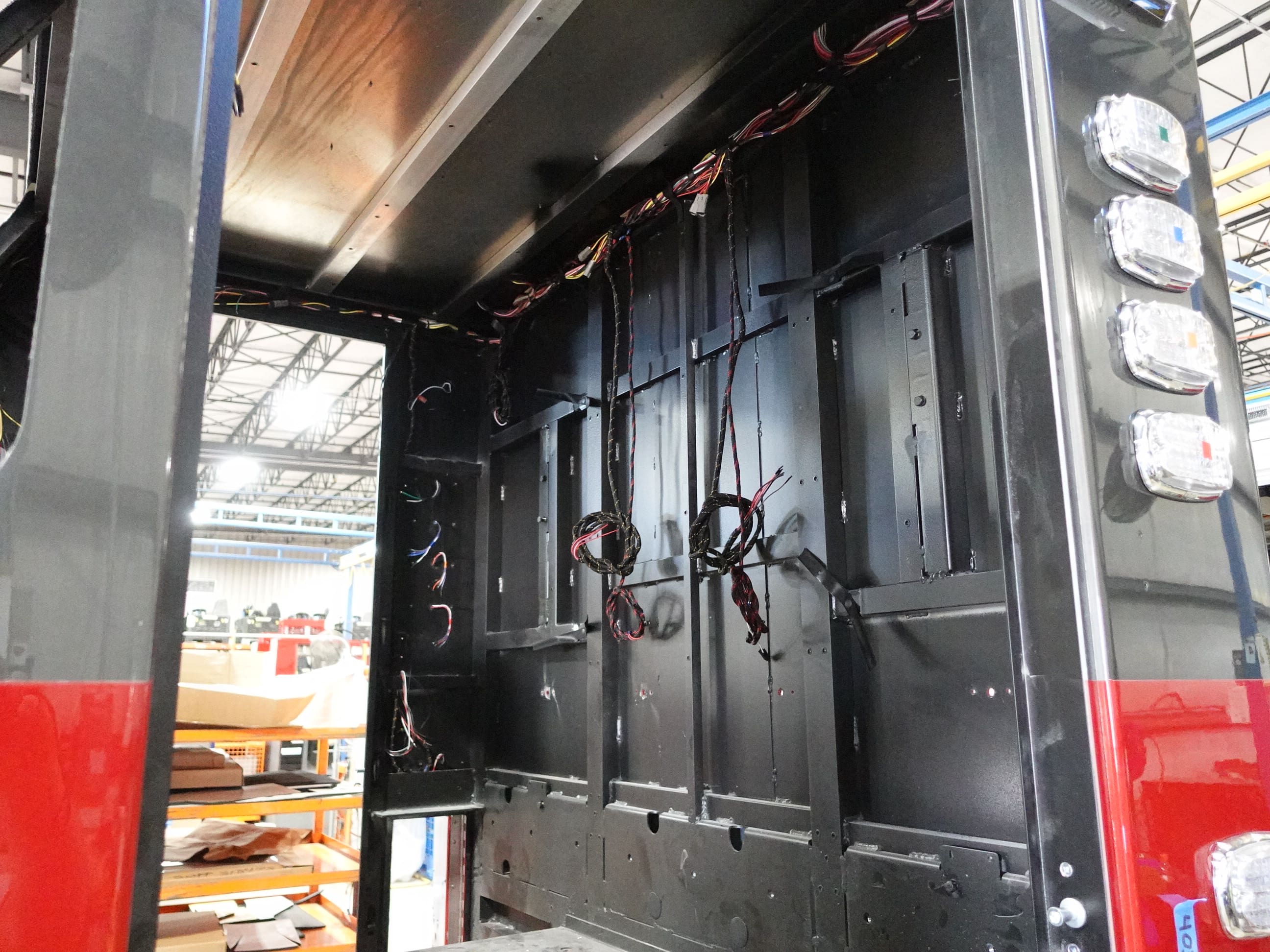

In this report, the chassis continued some assembly in an offline area of production while the
body was unavailable for photos.
06-12-26

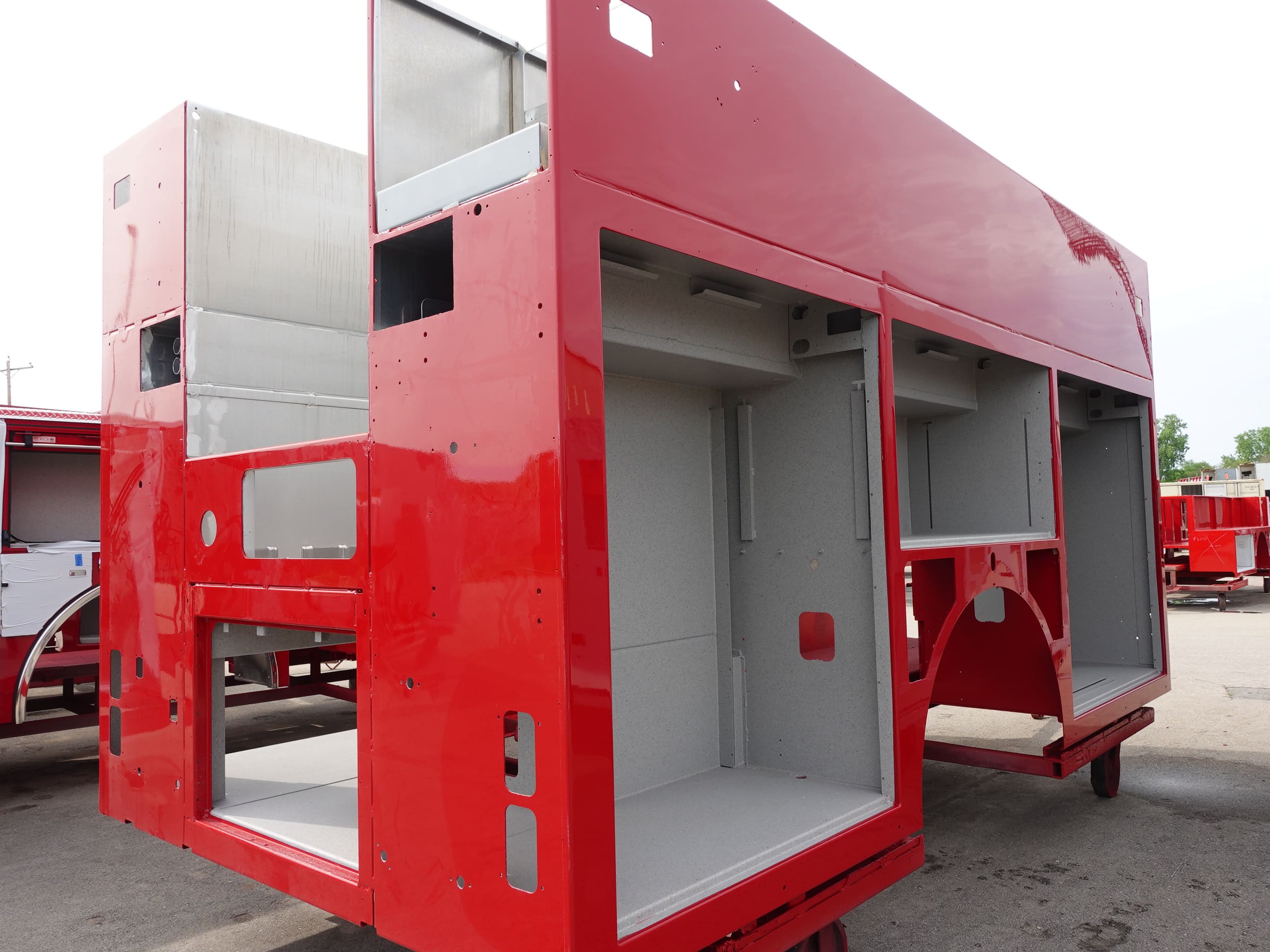

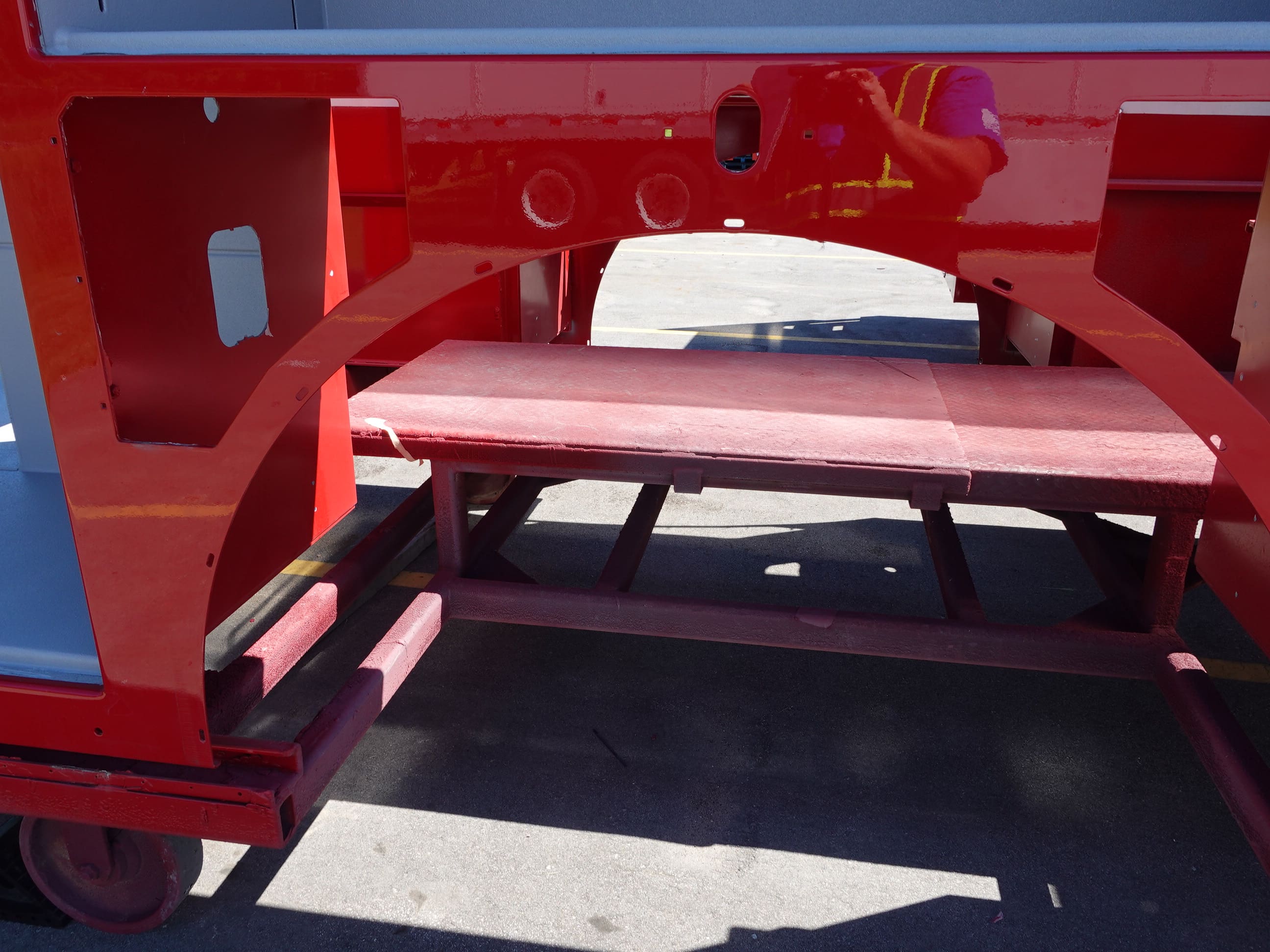

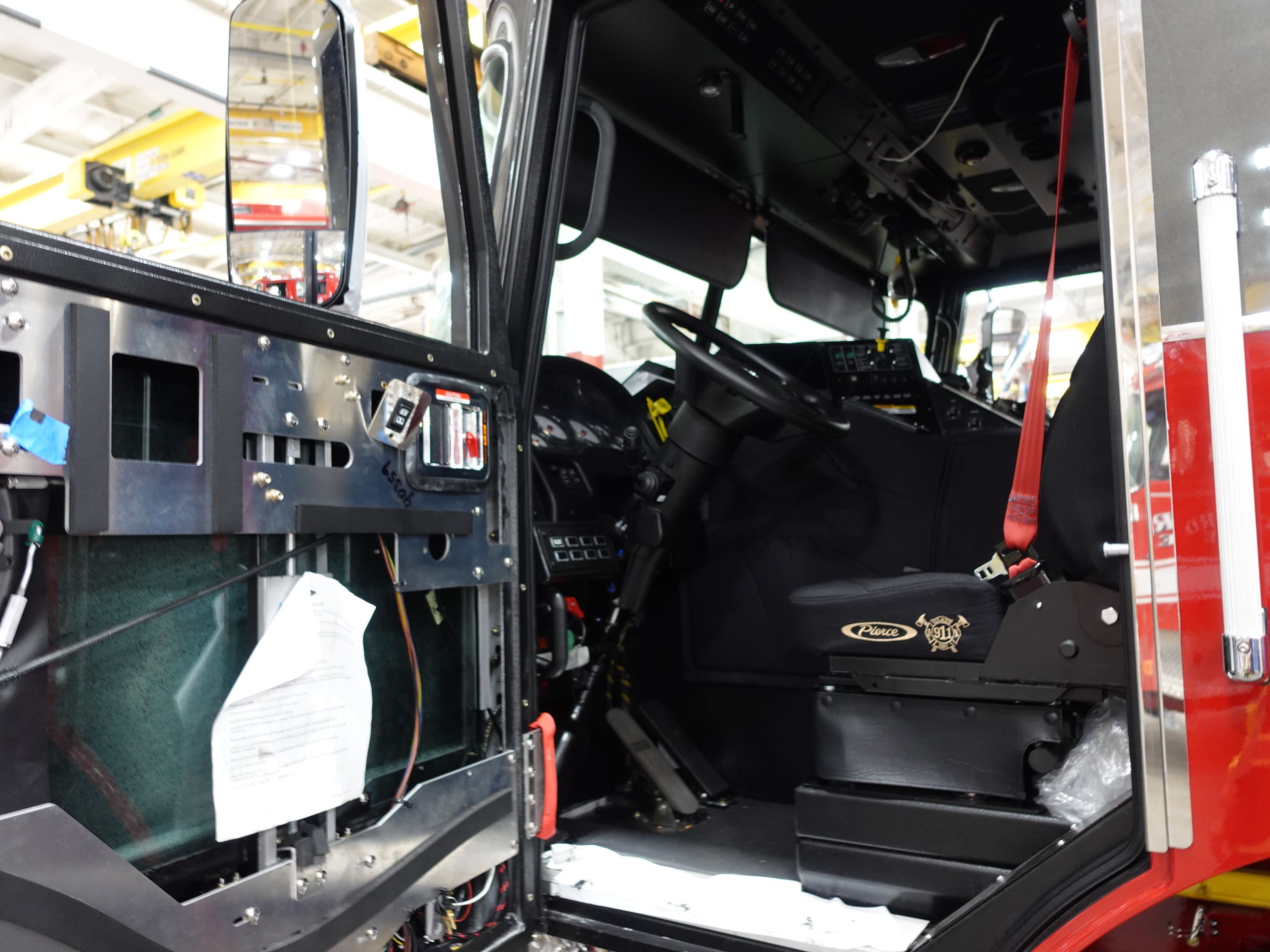

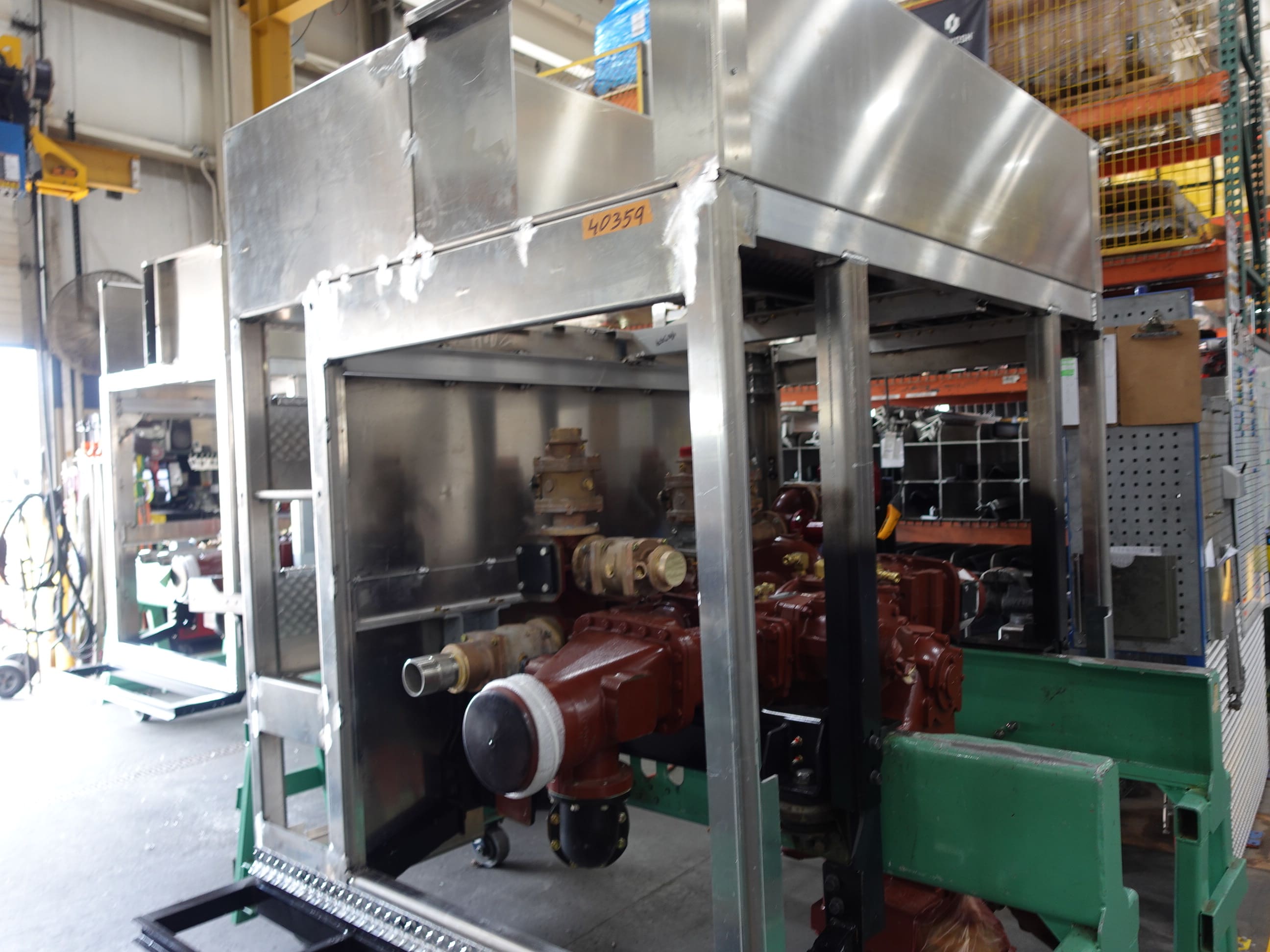

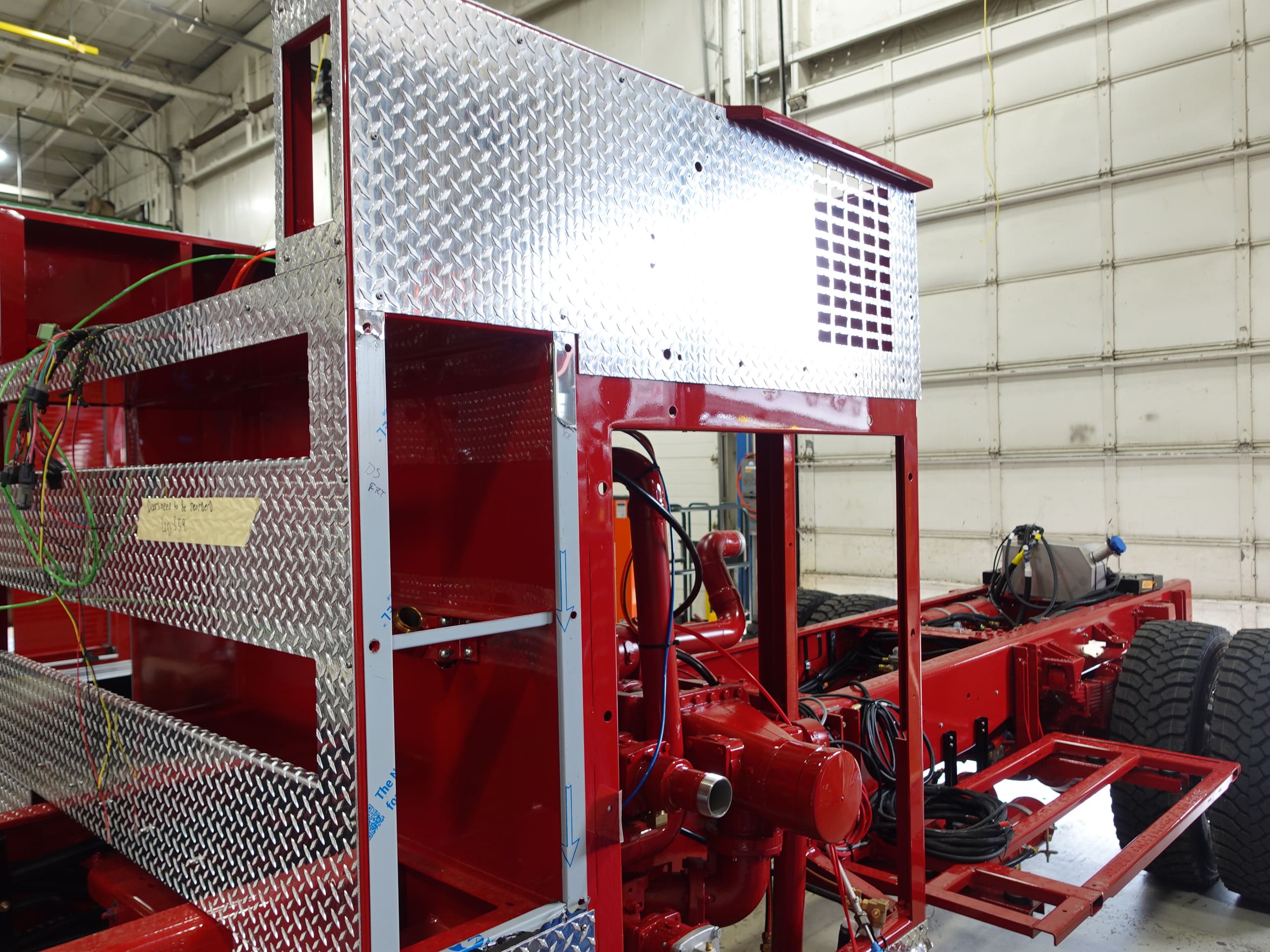

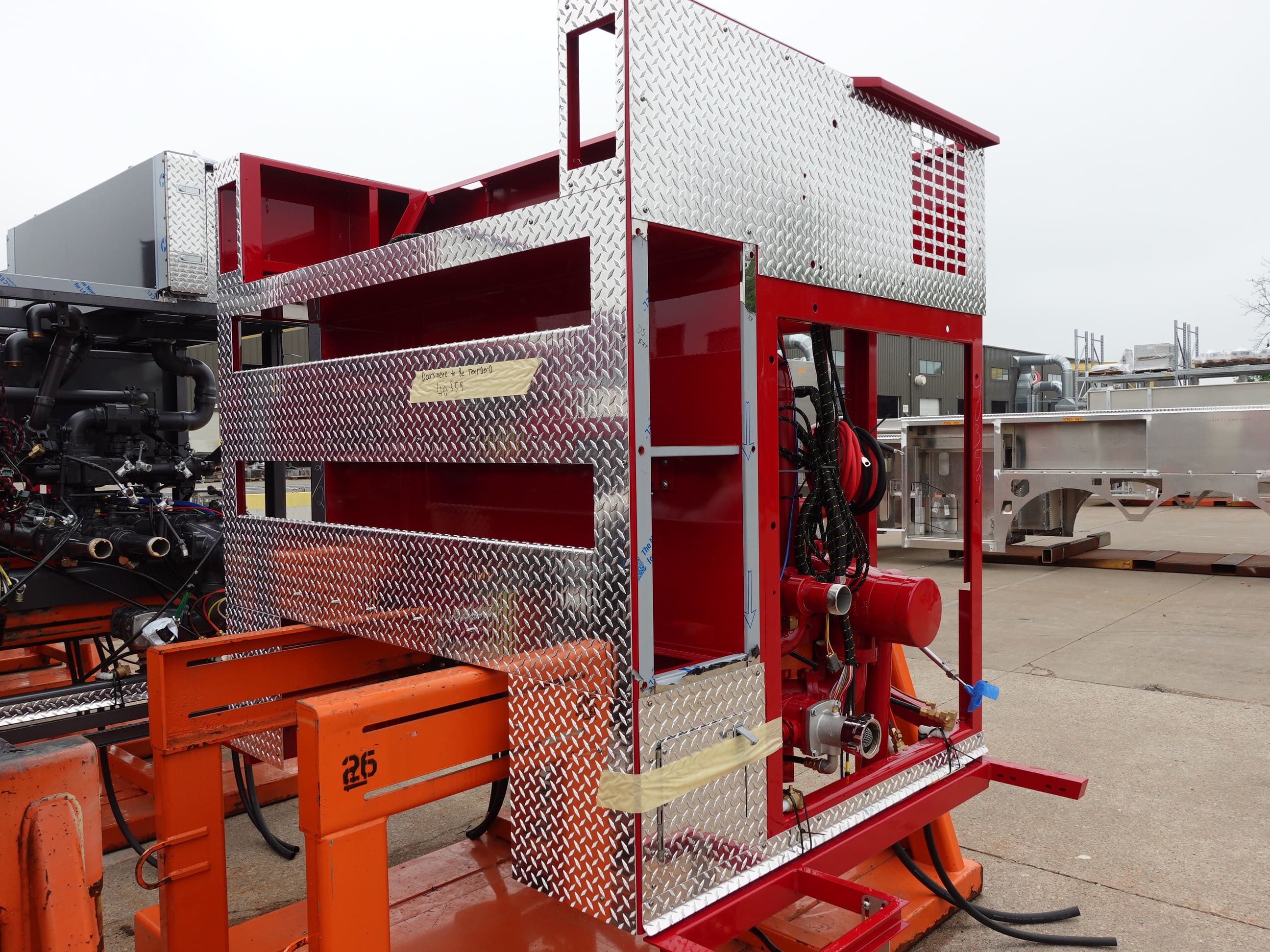

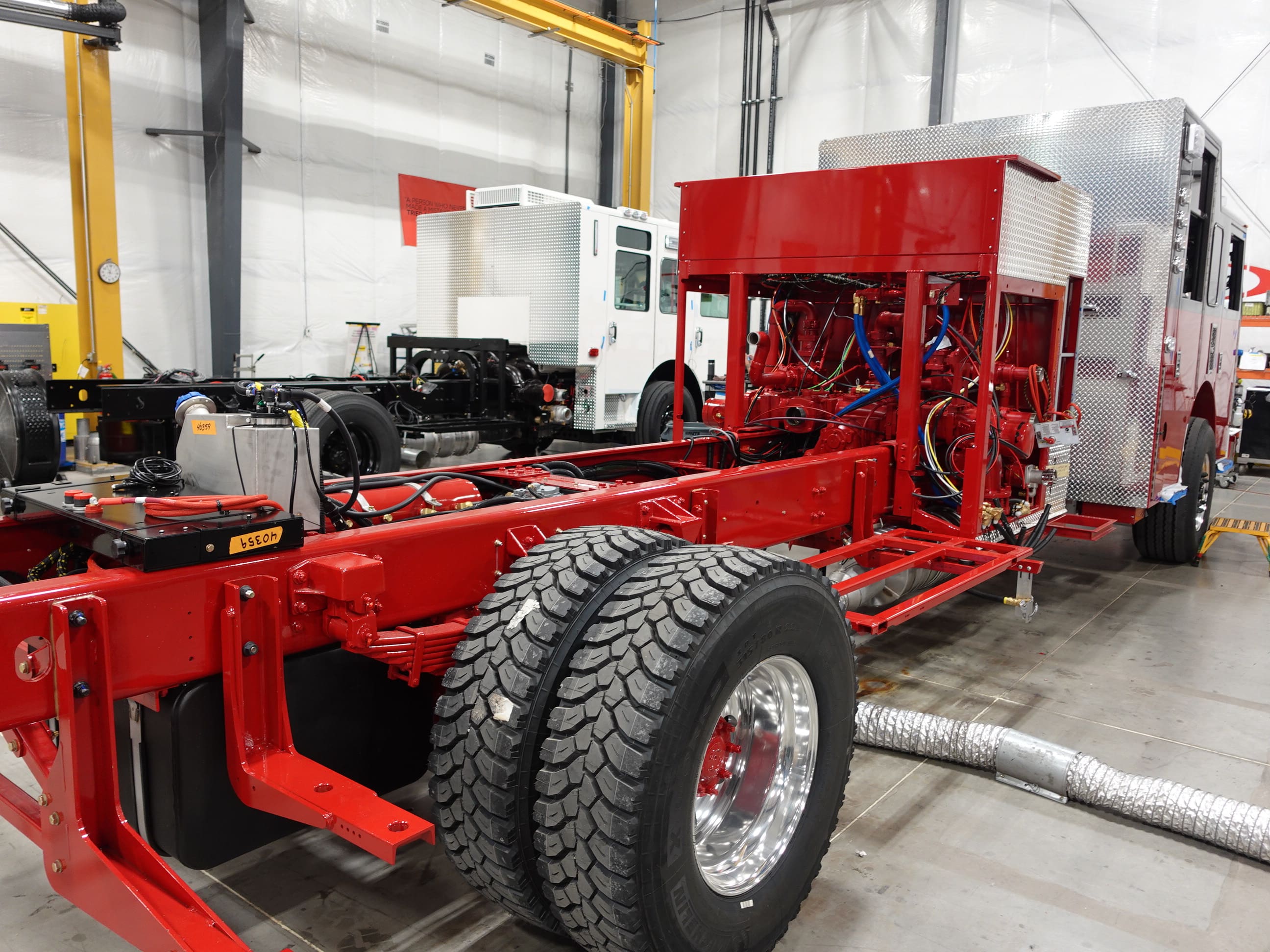

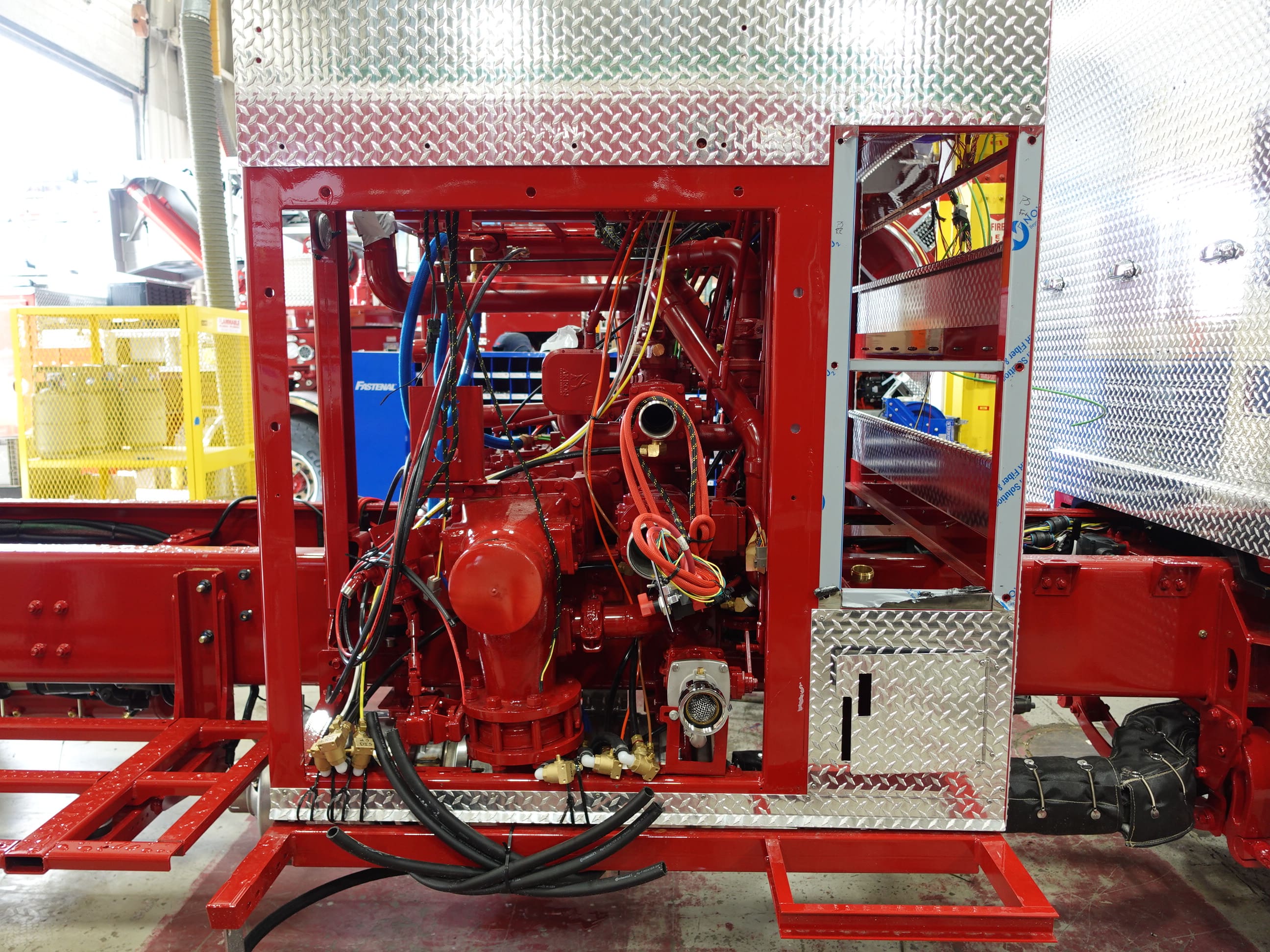

In this report, the cab and pump house were merged
with the frame while the body remained staged.

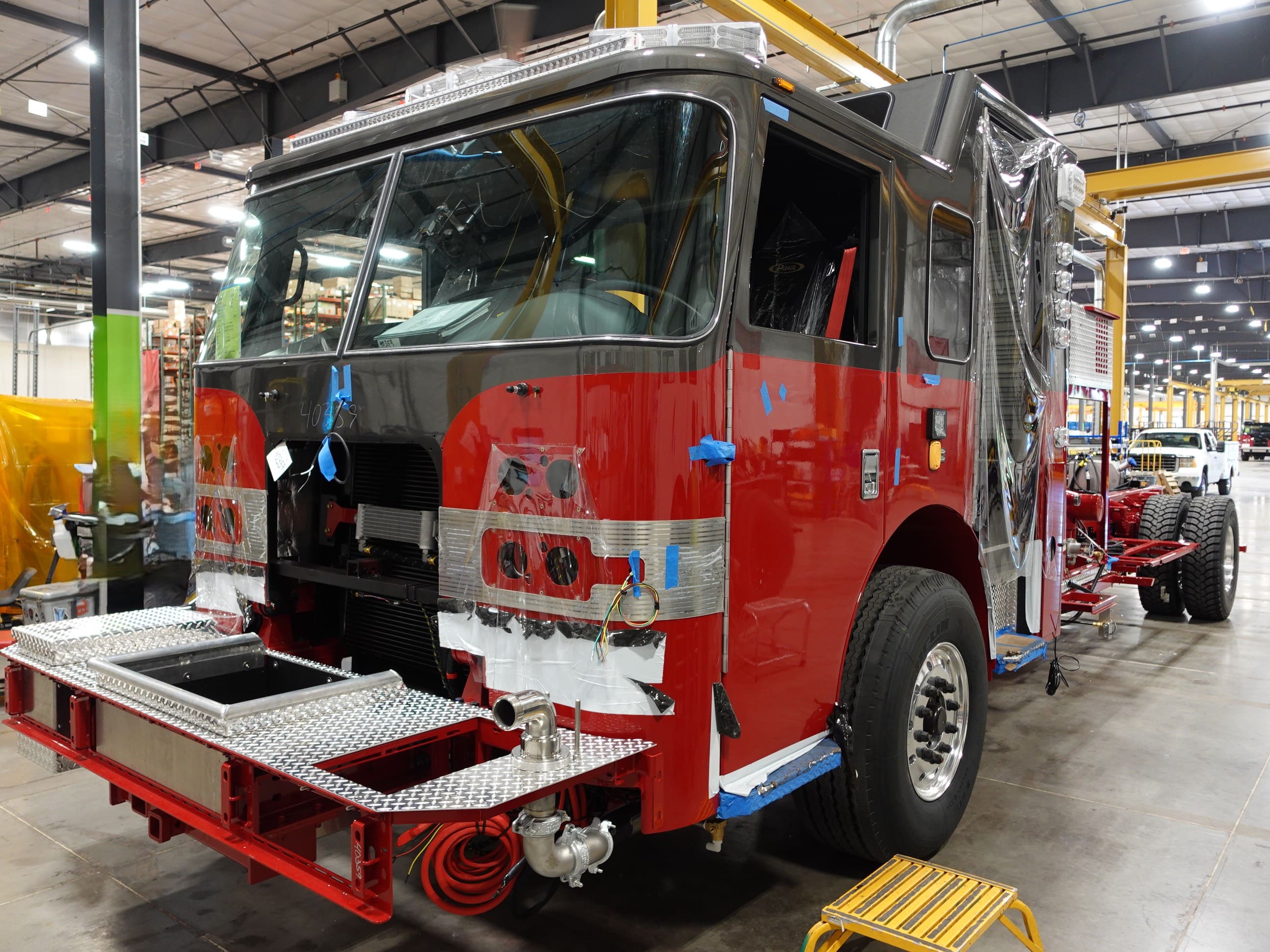

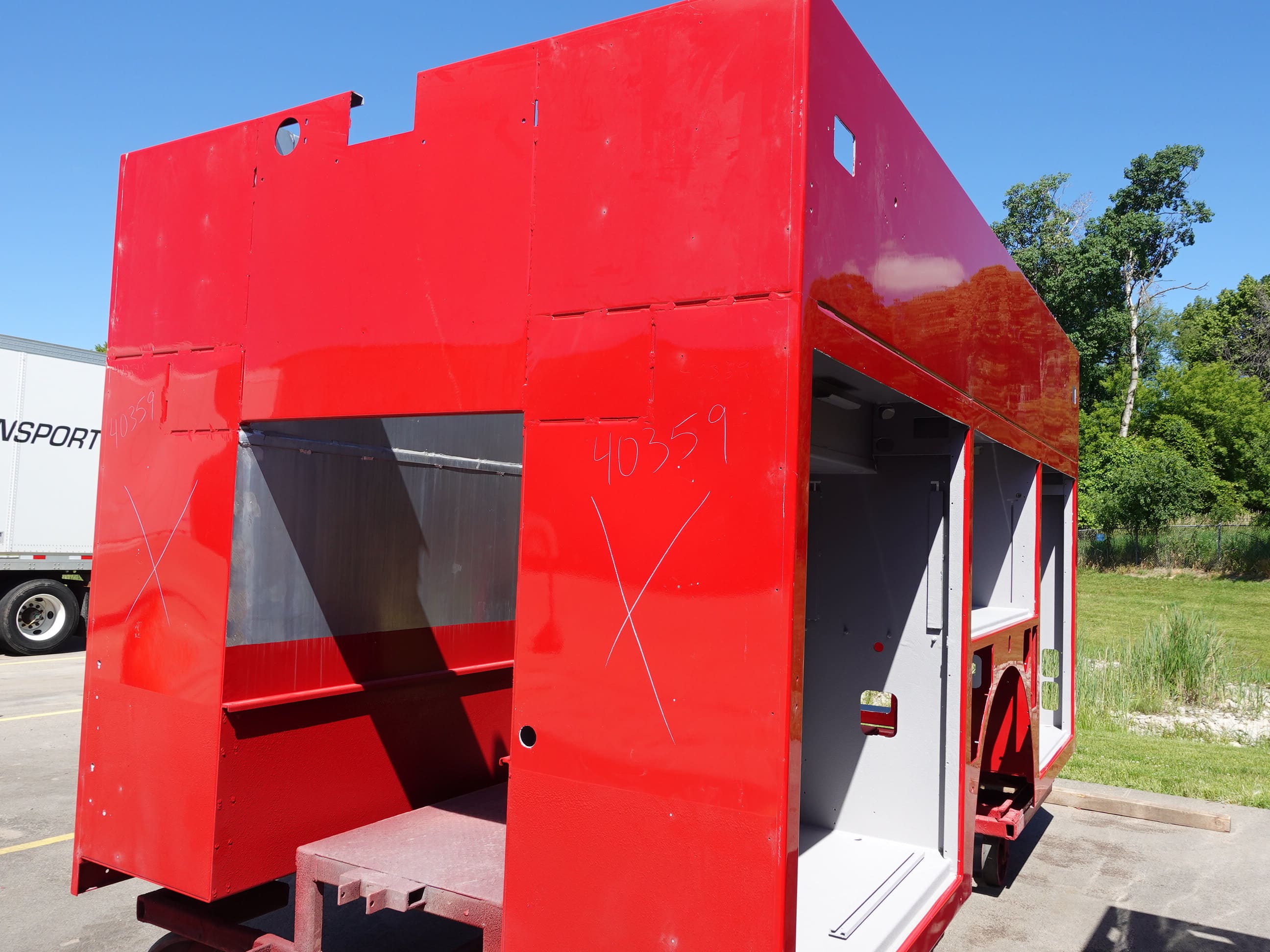

06-05-26

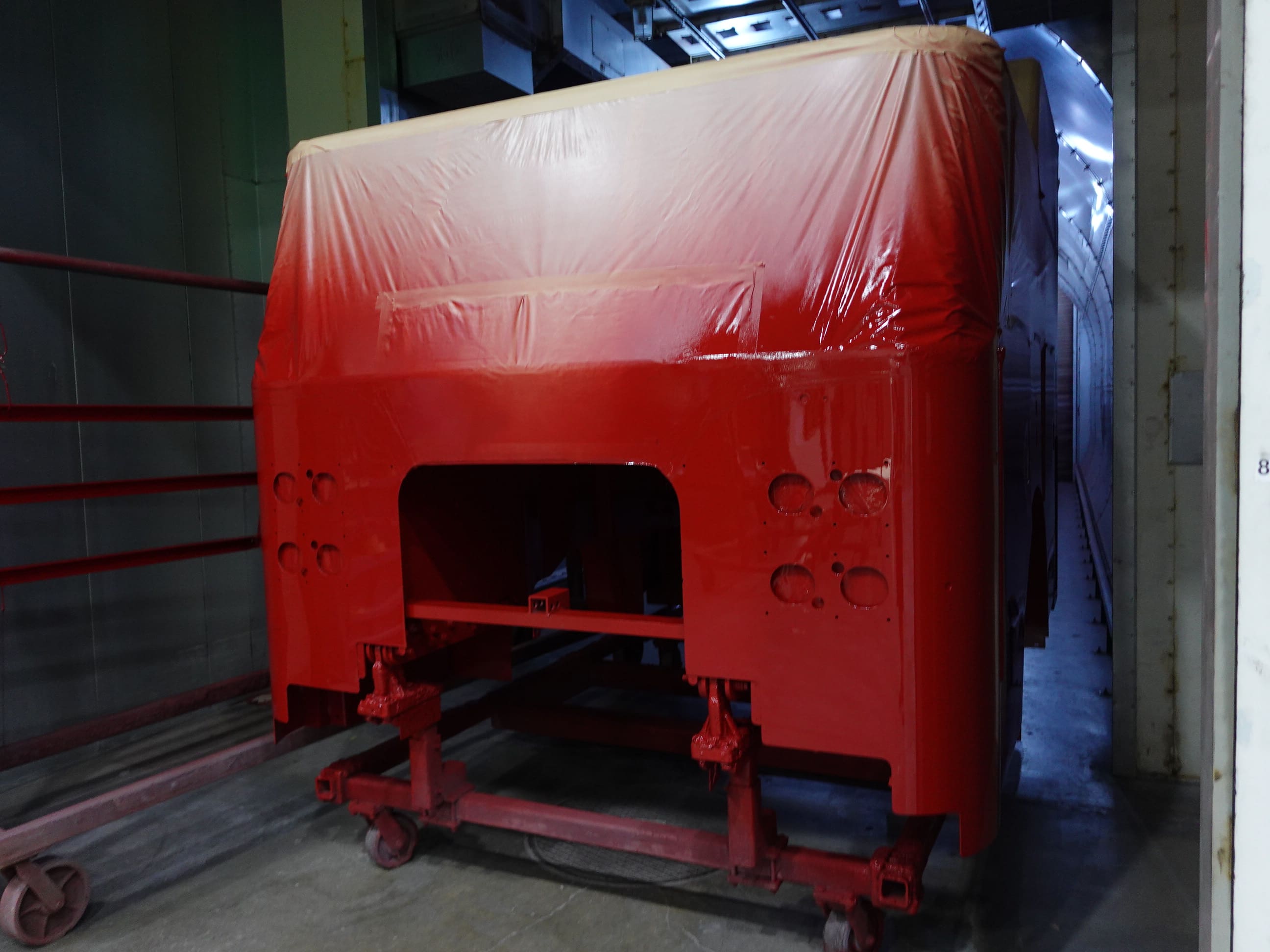

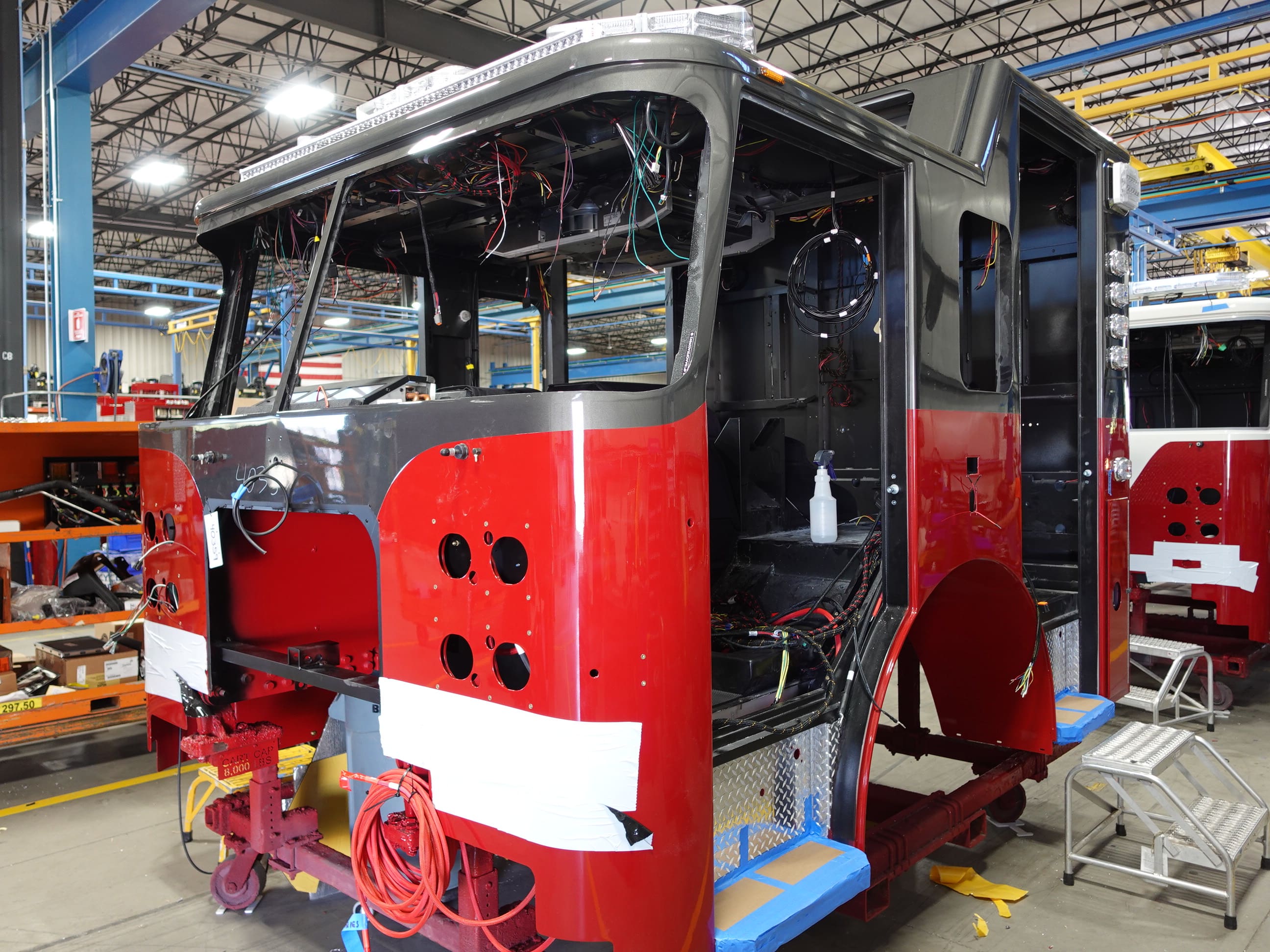

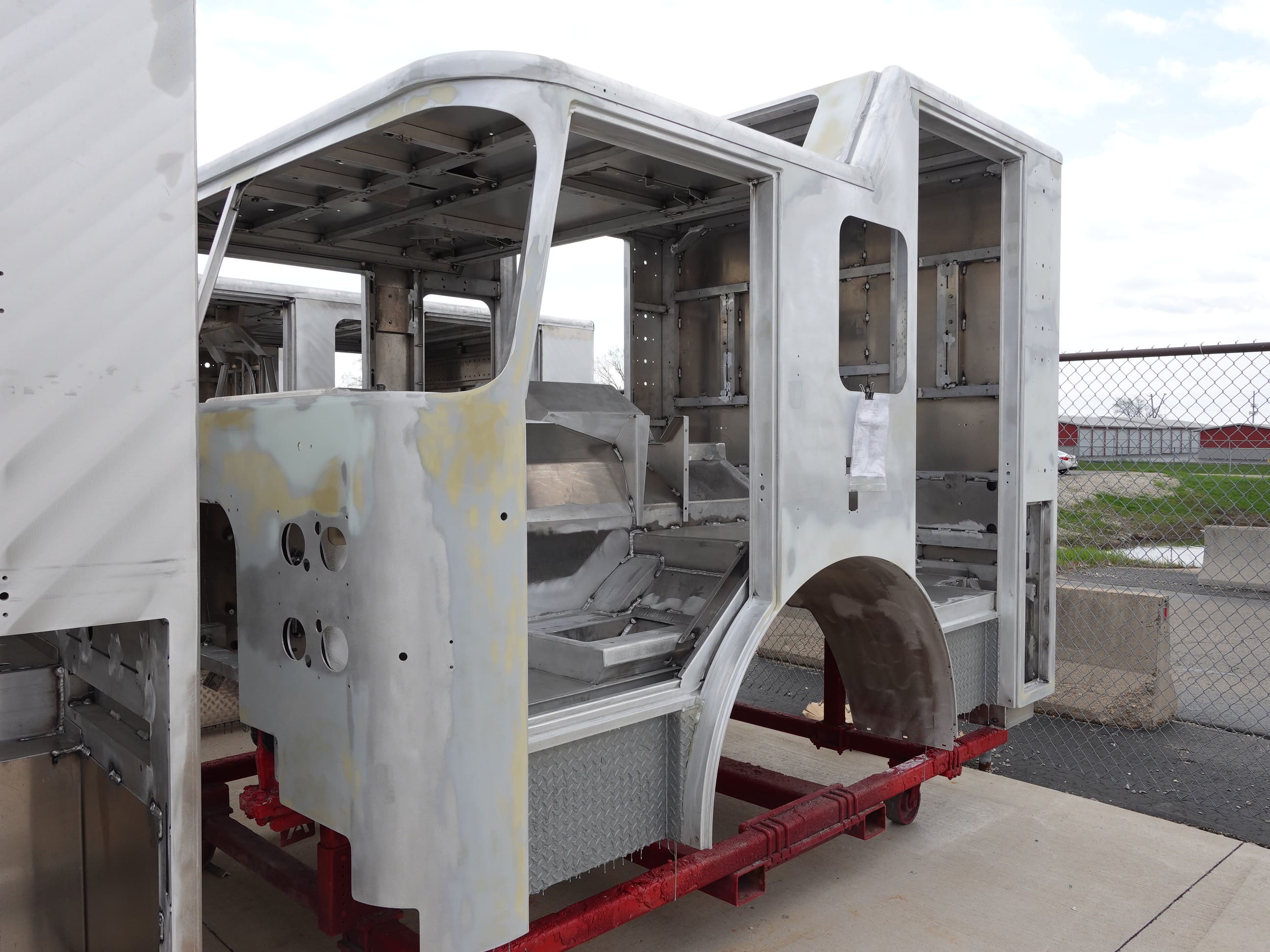

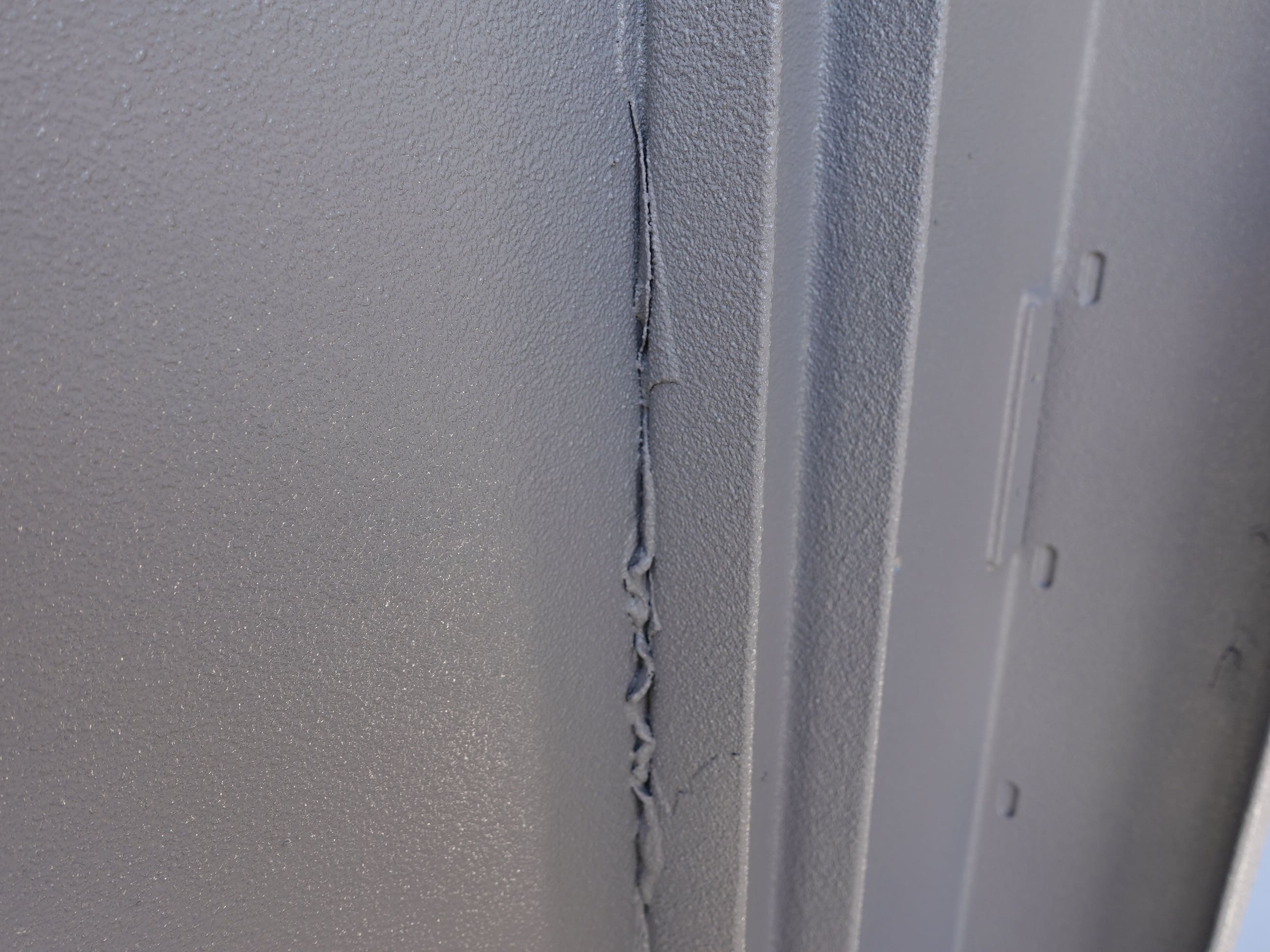

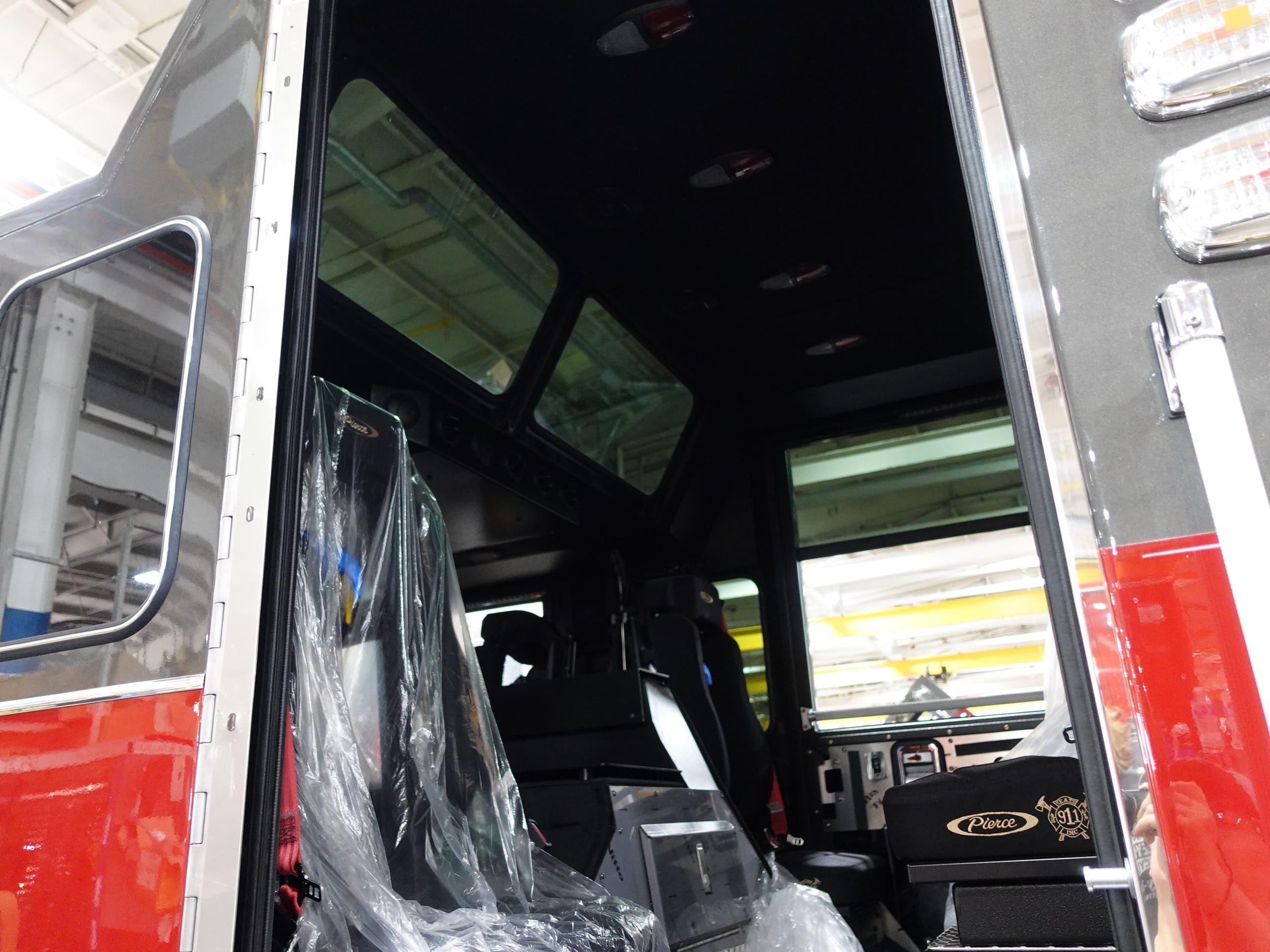

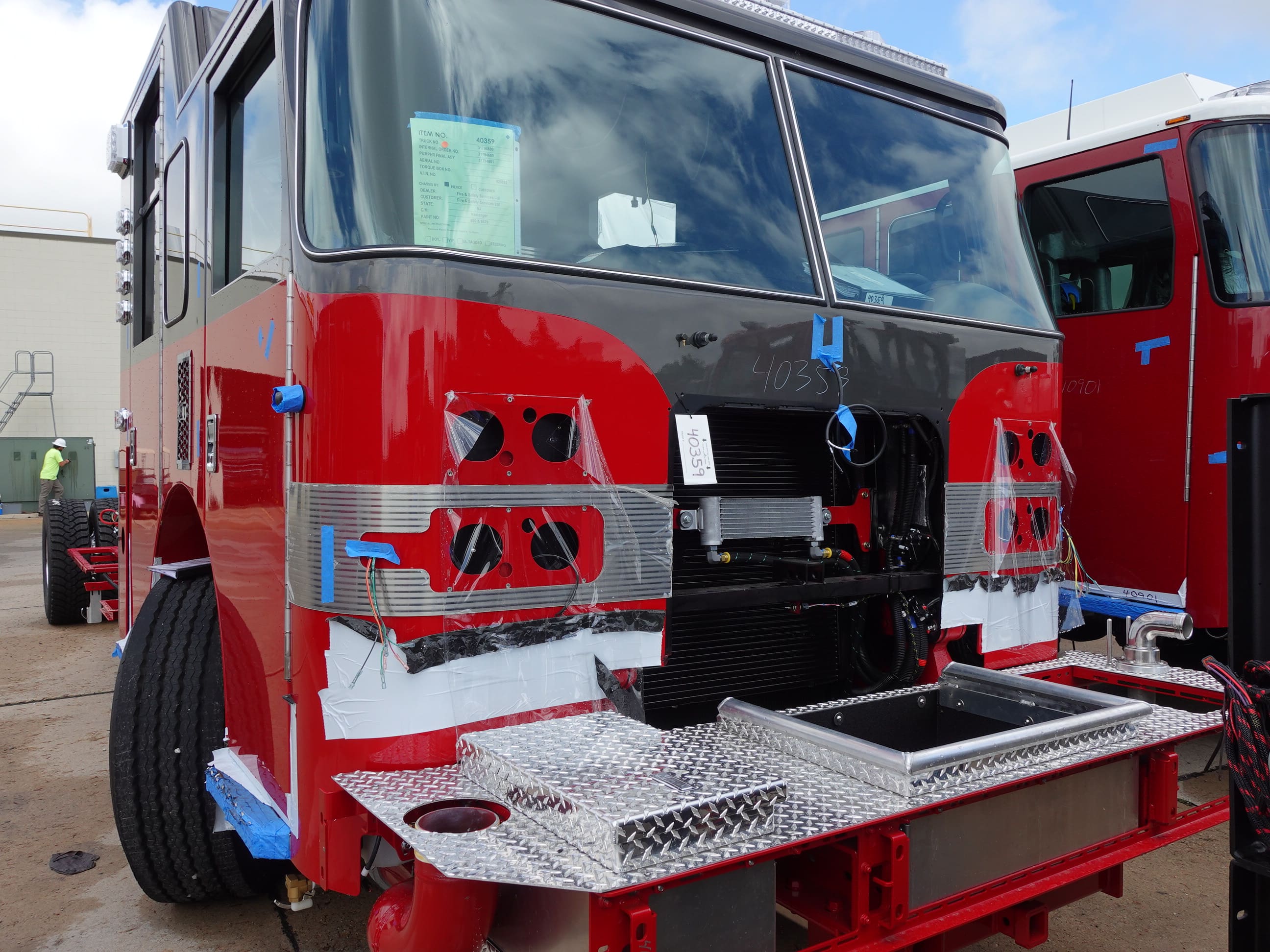

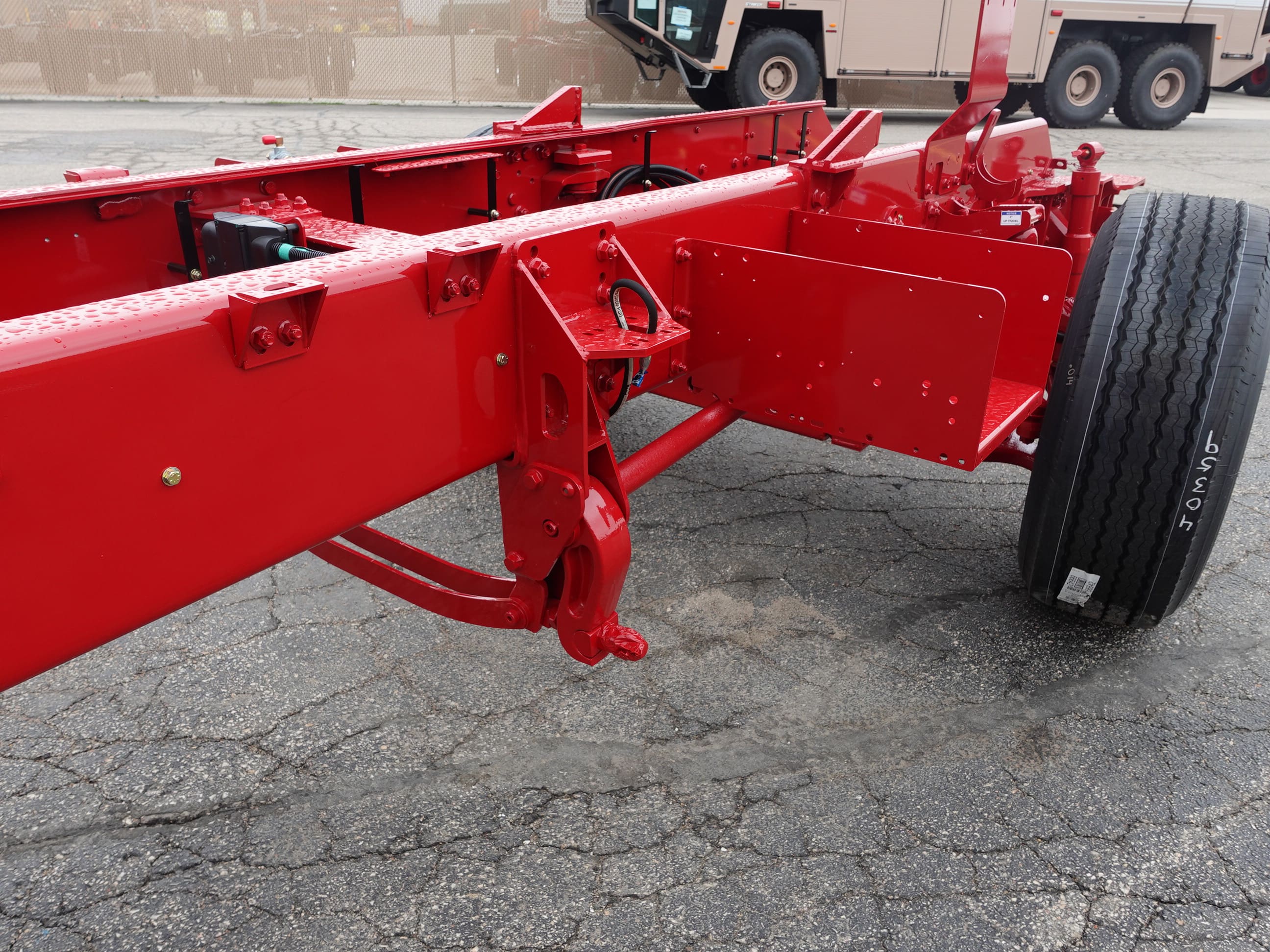

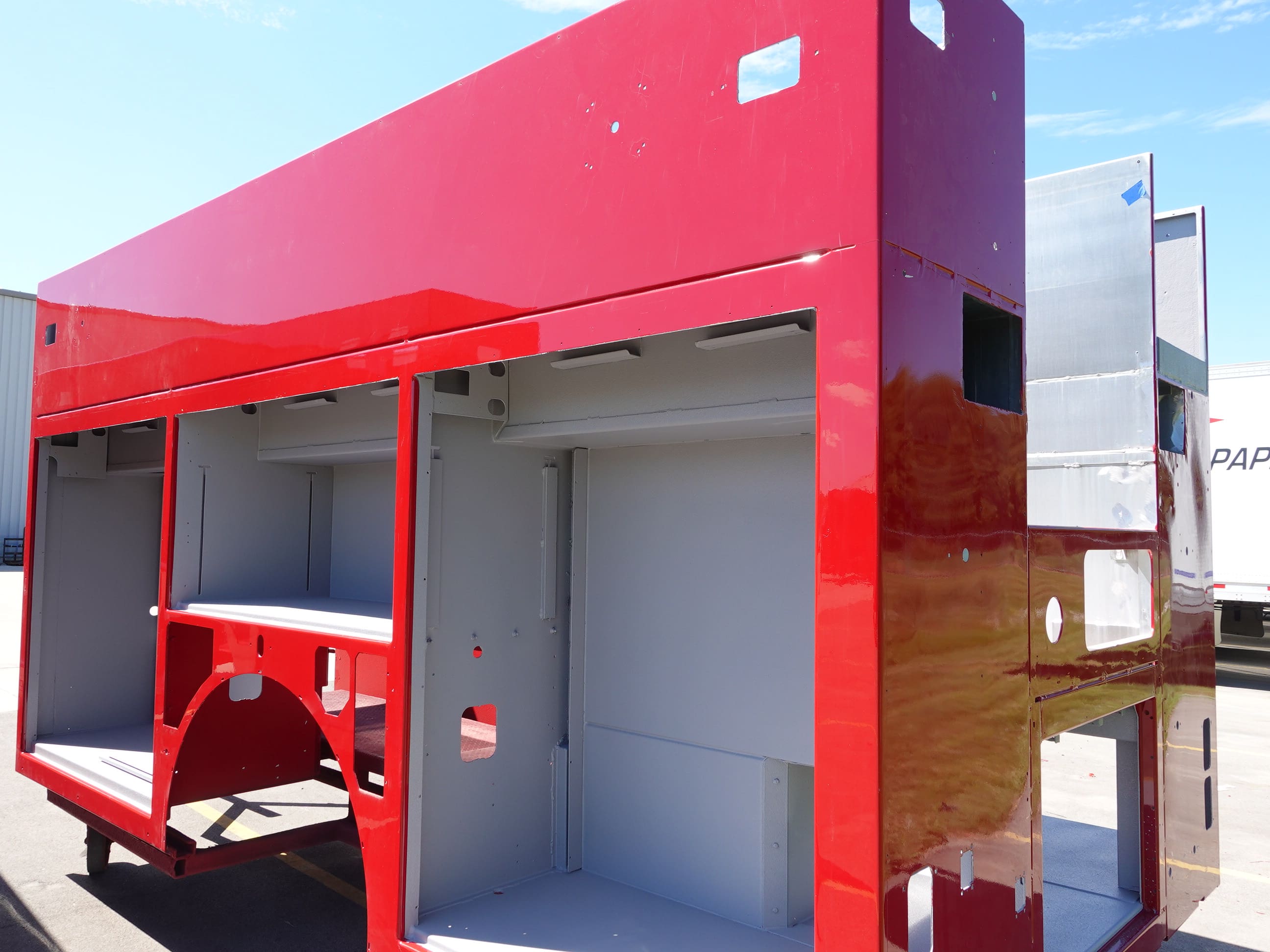

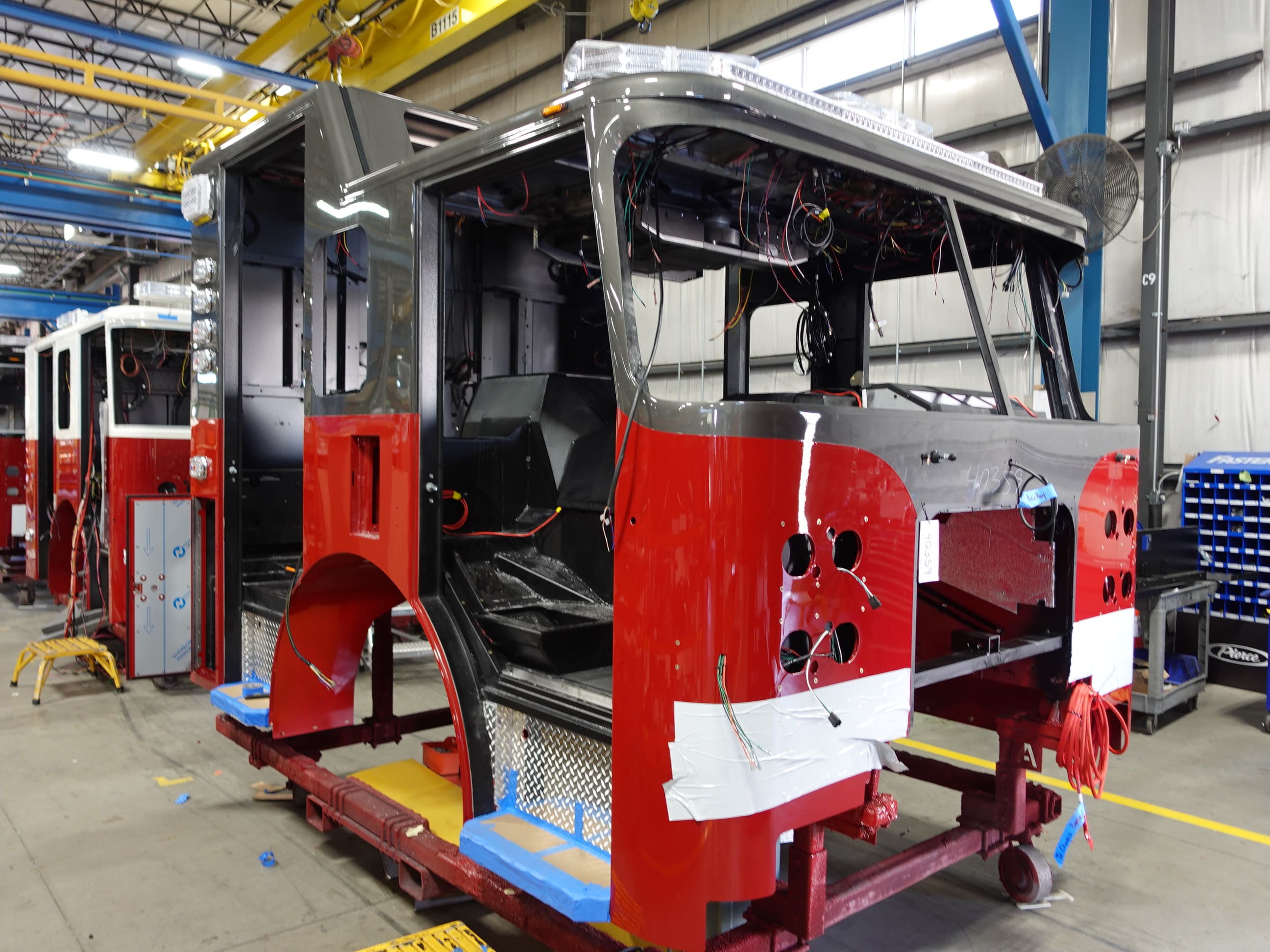

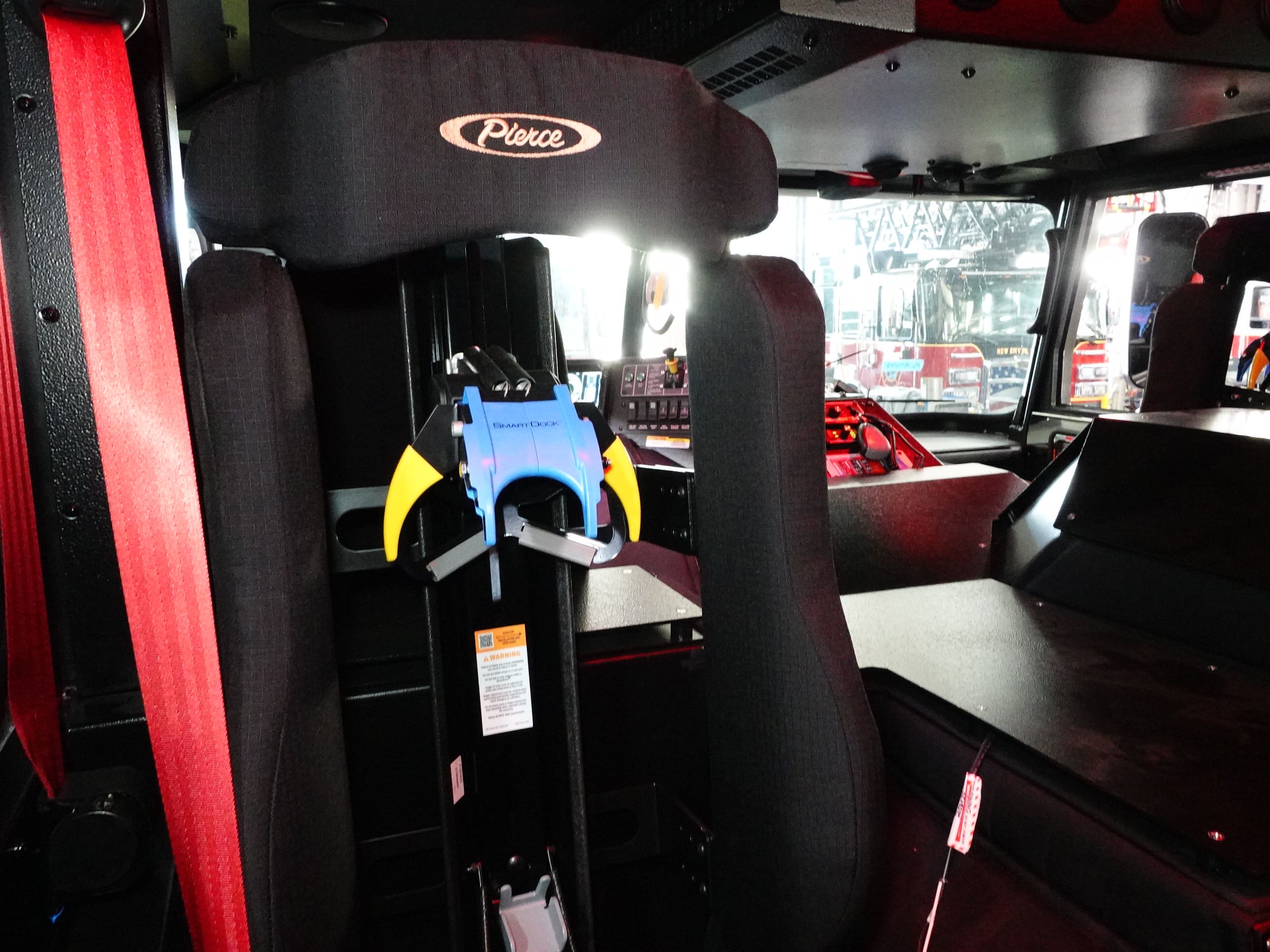

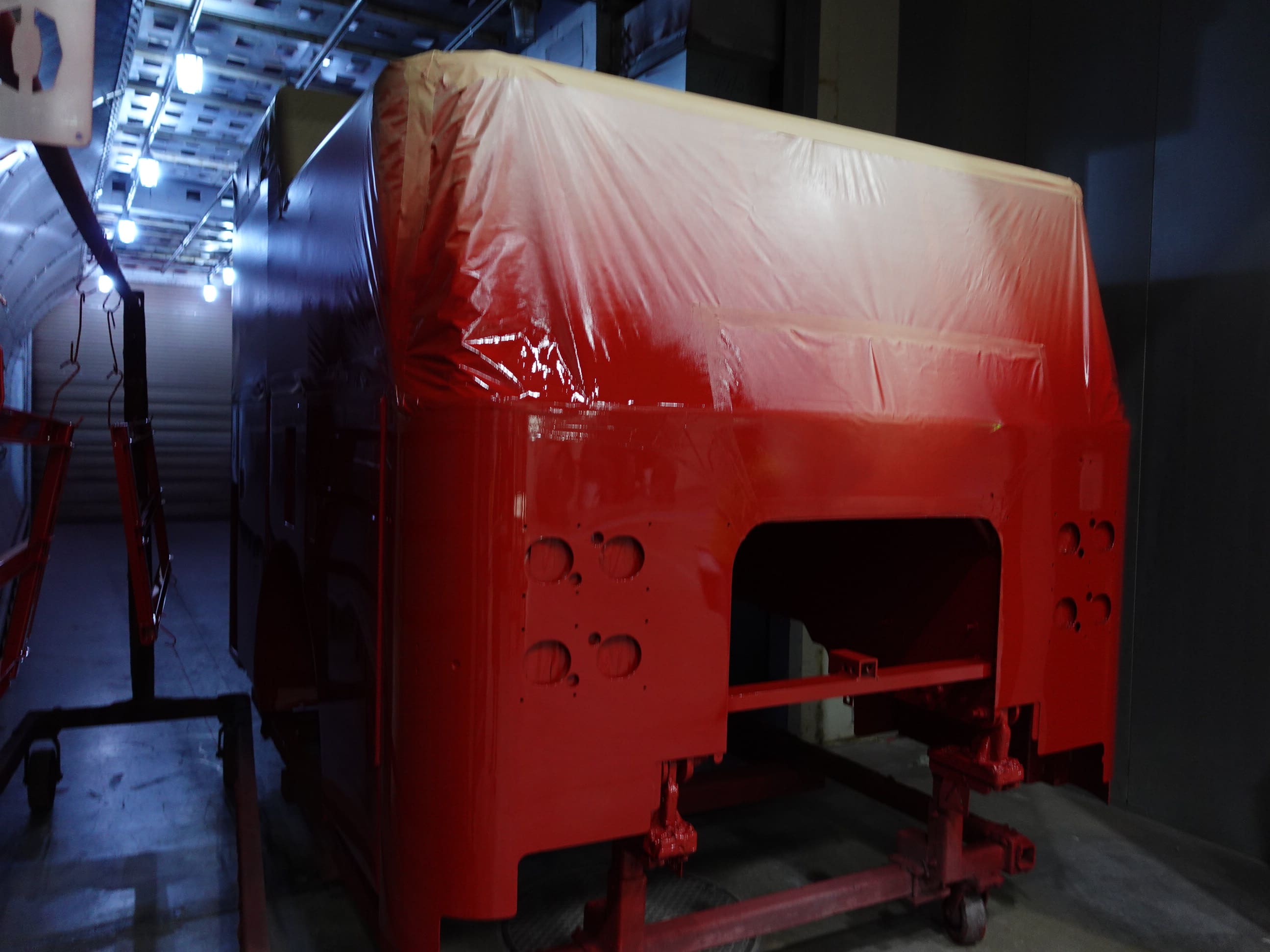

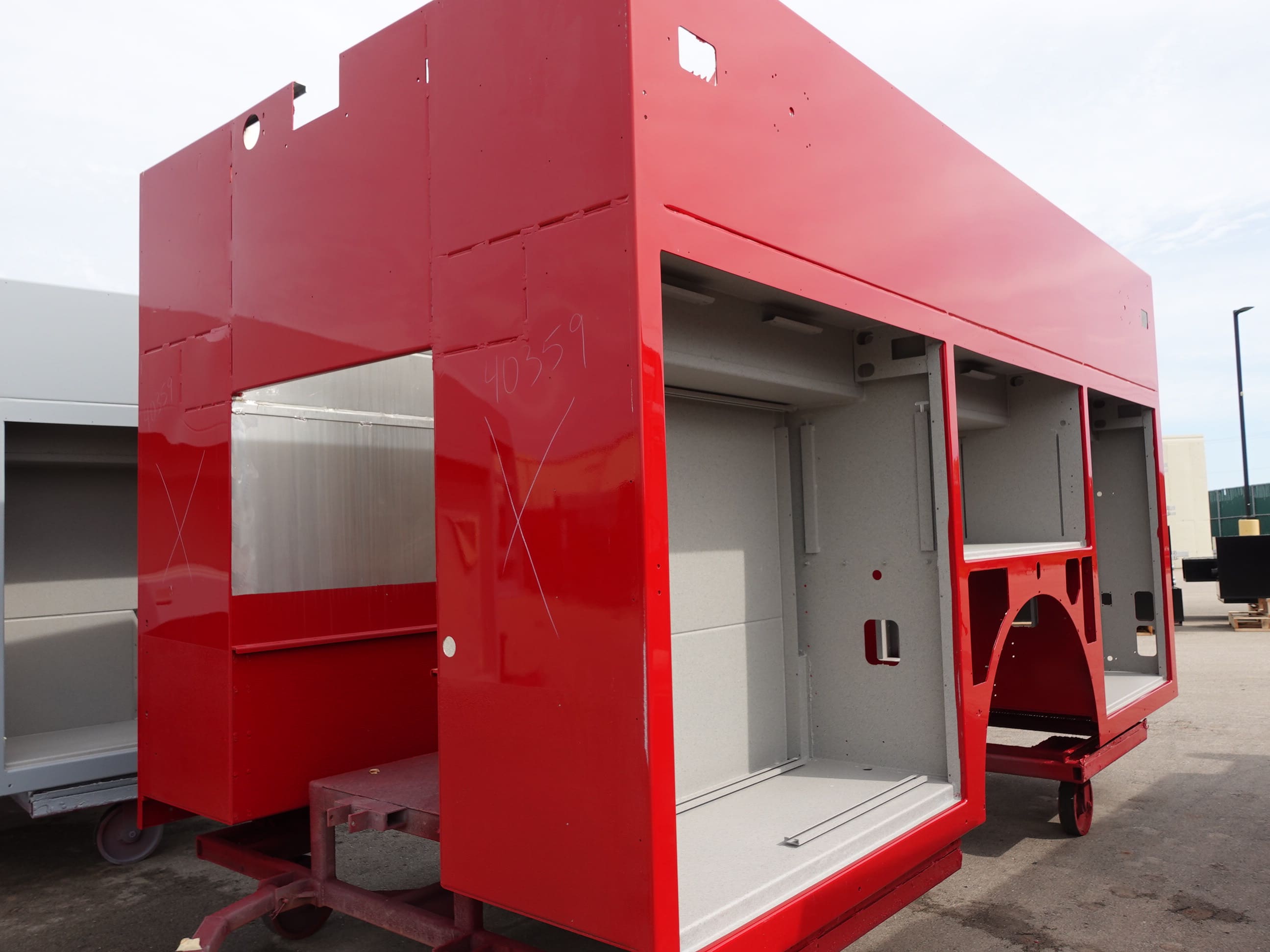

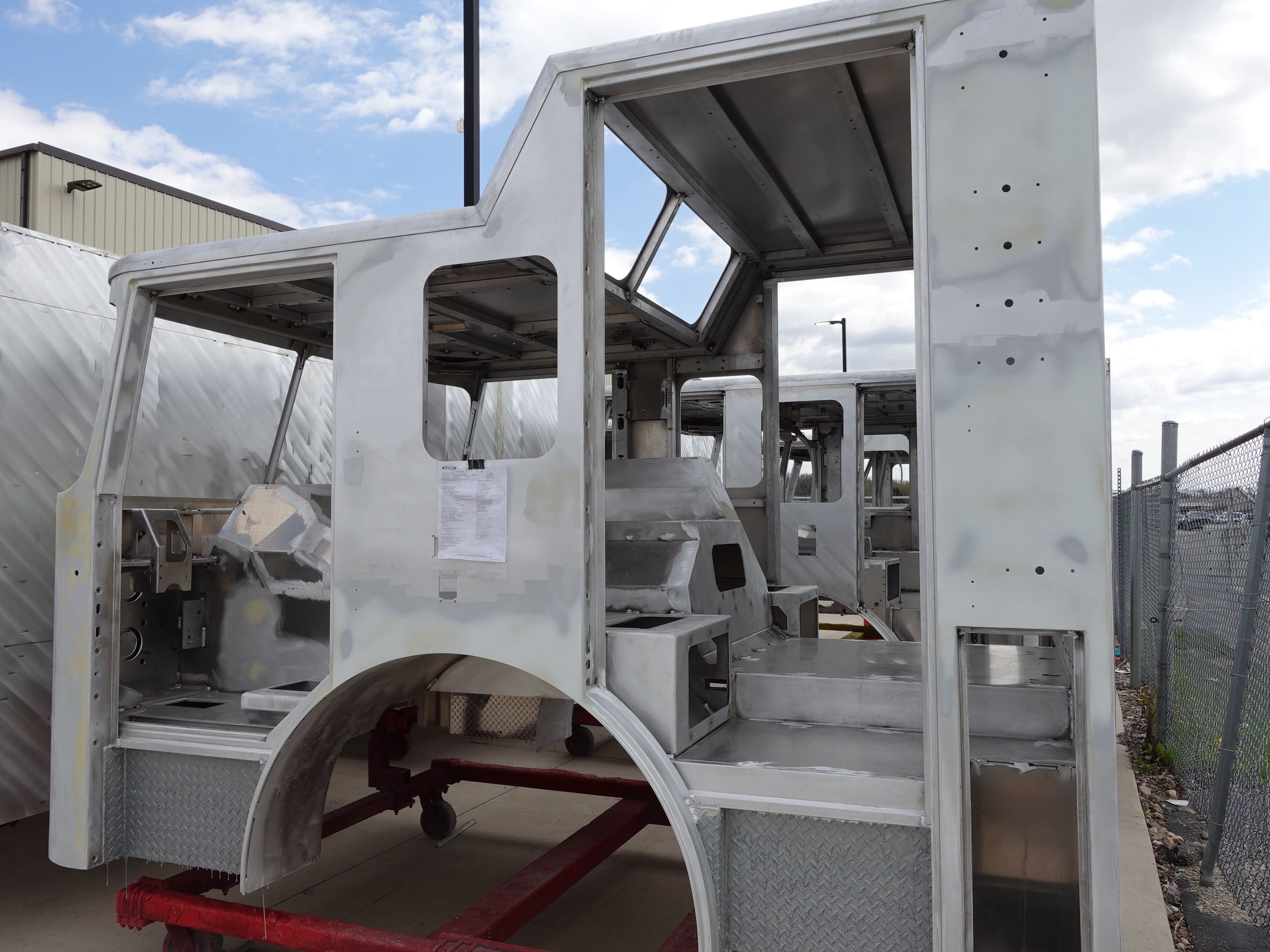

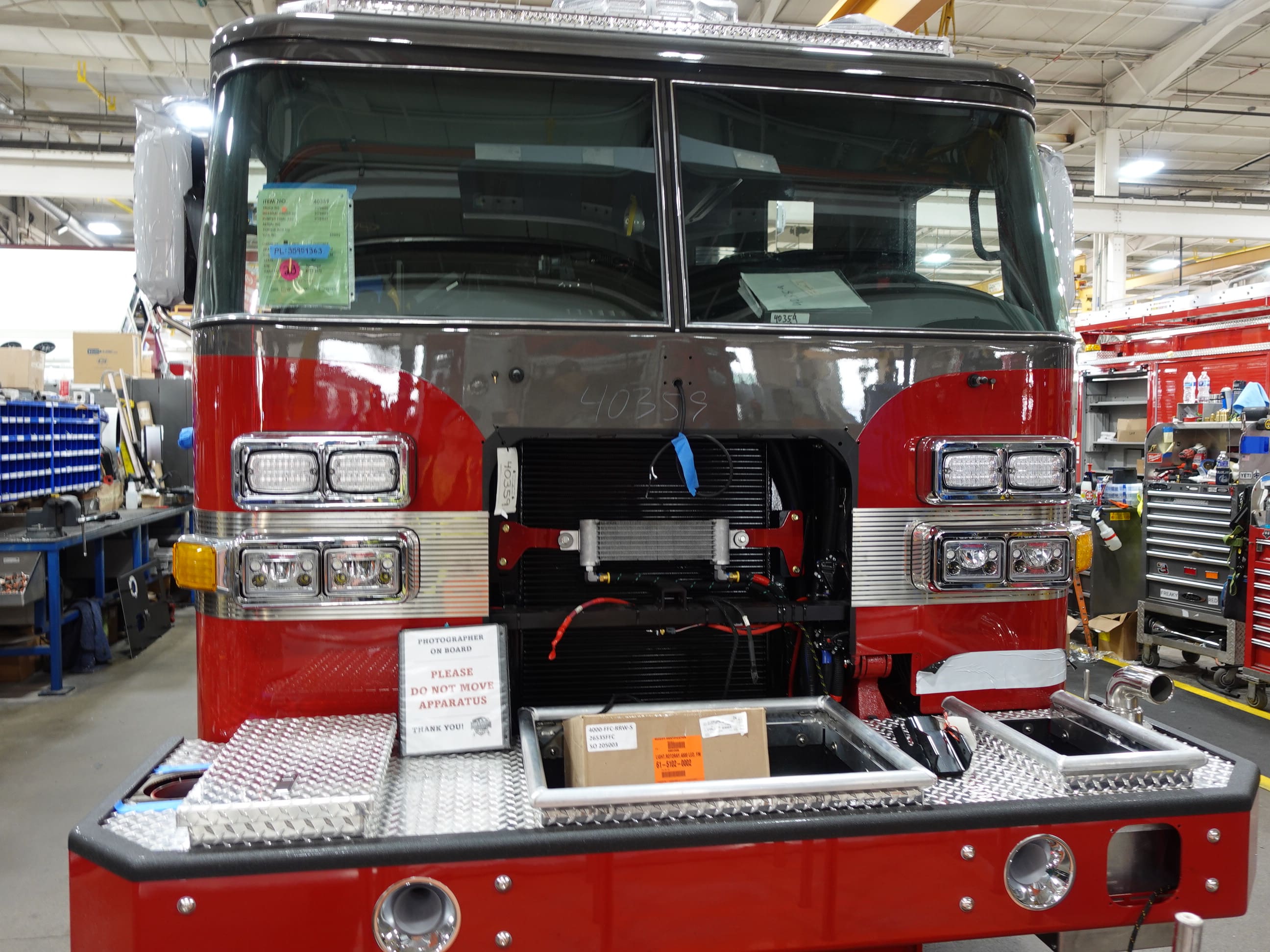

In this report, the cab completed paint and began initial

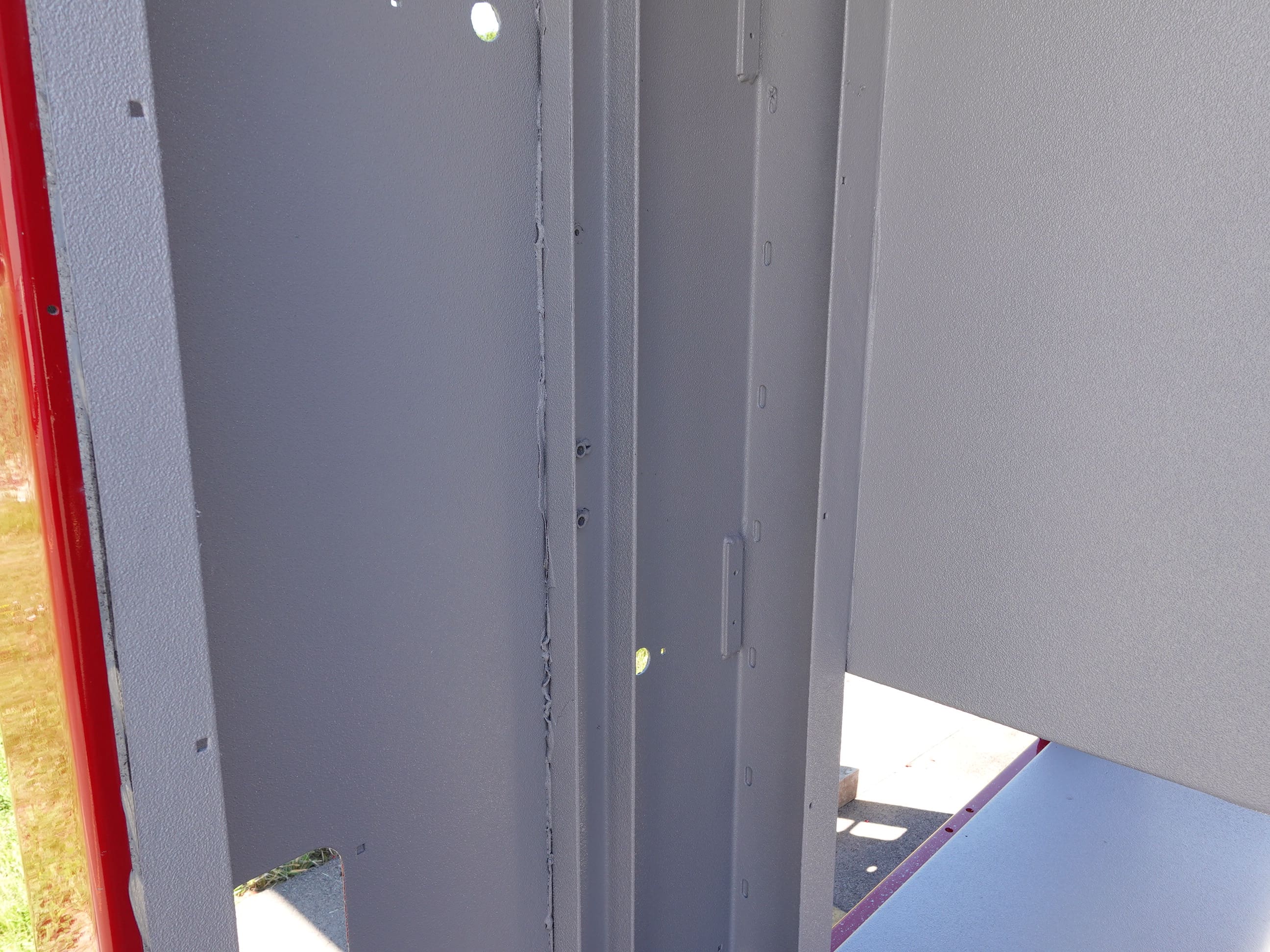

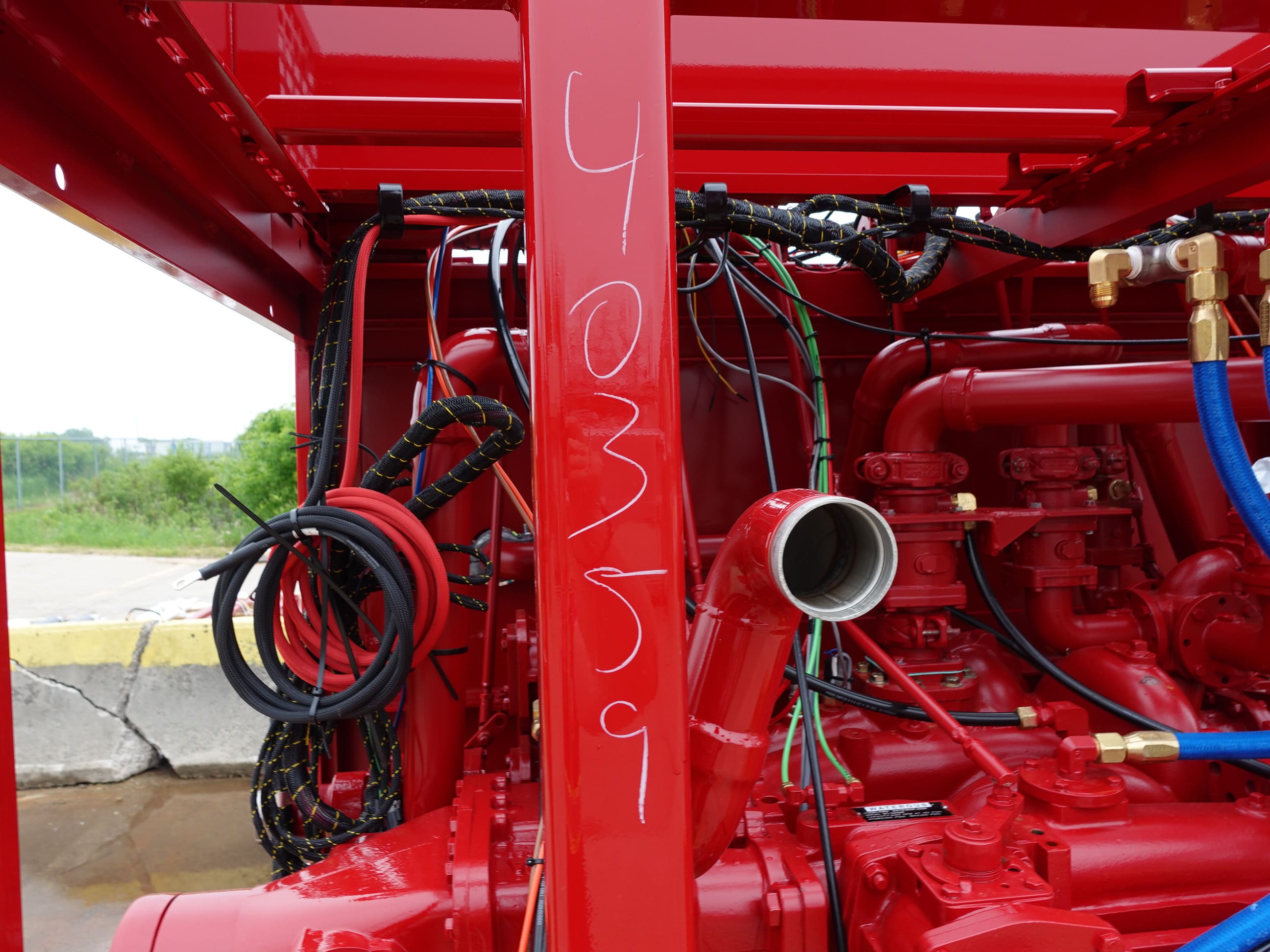

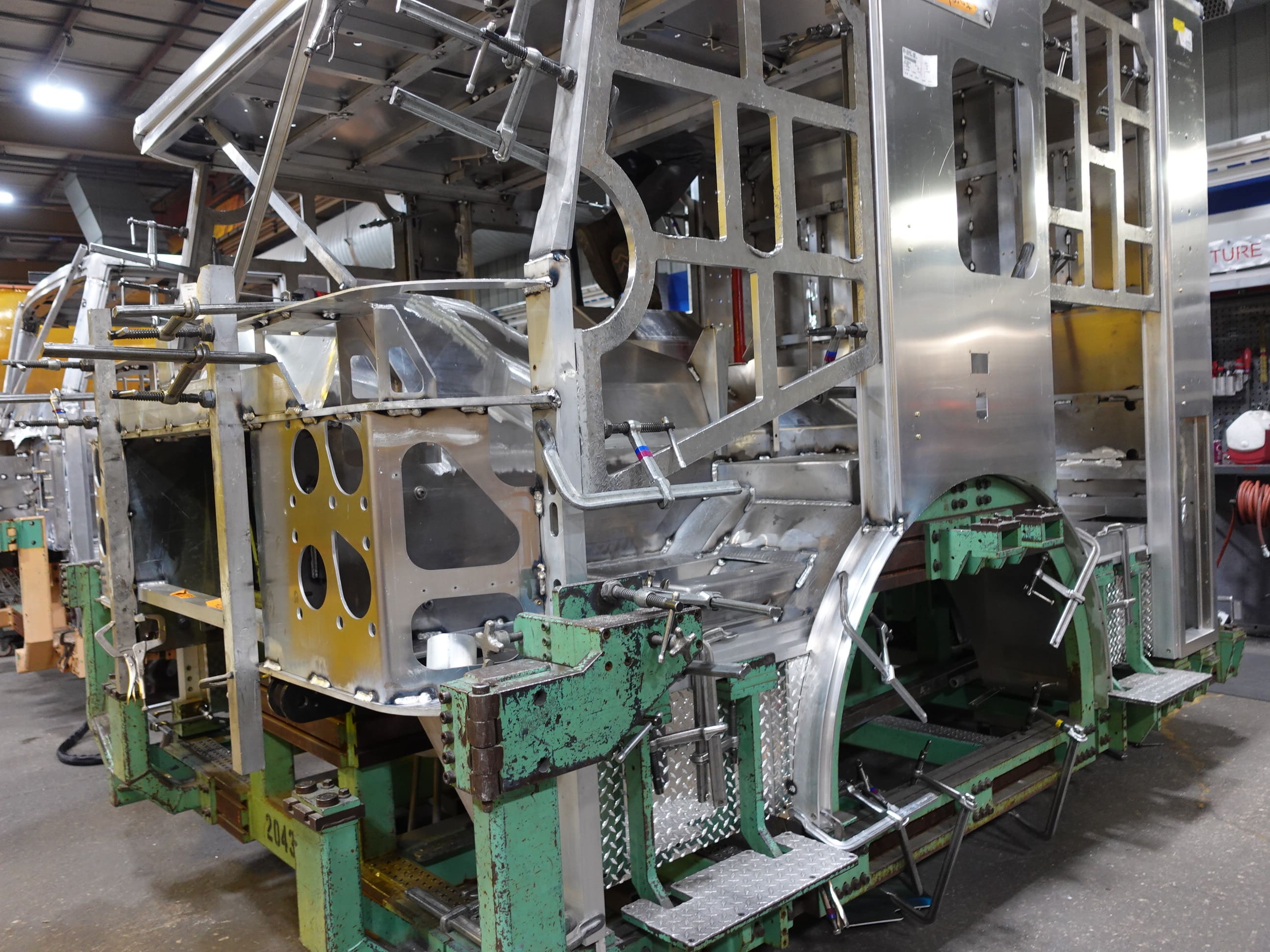

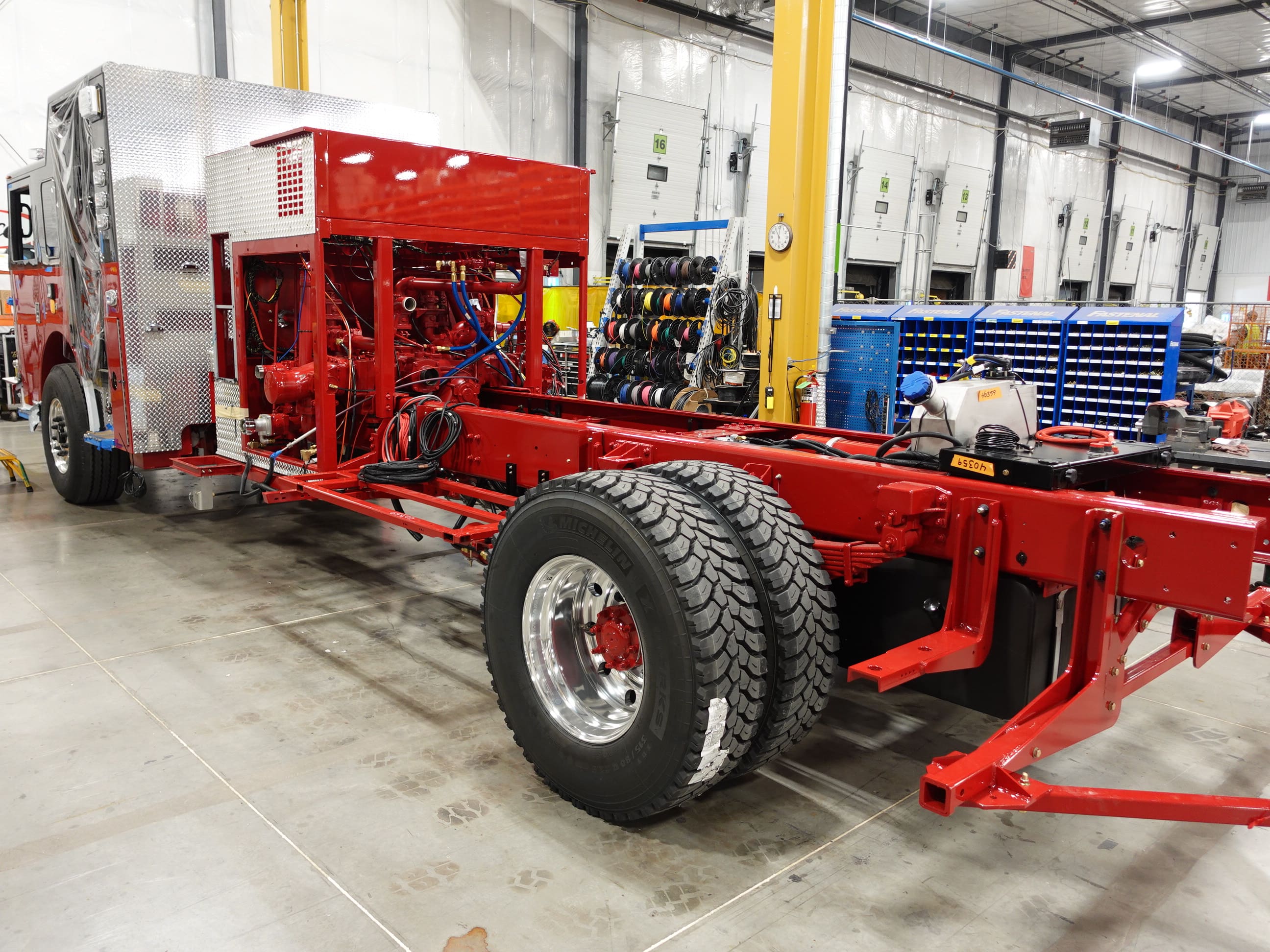

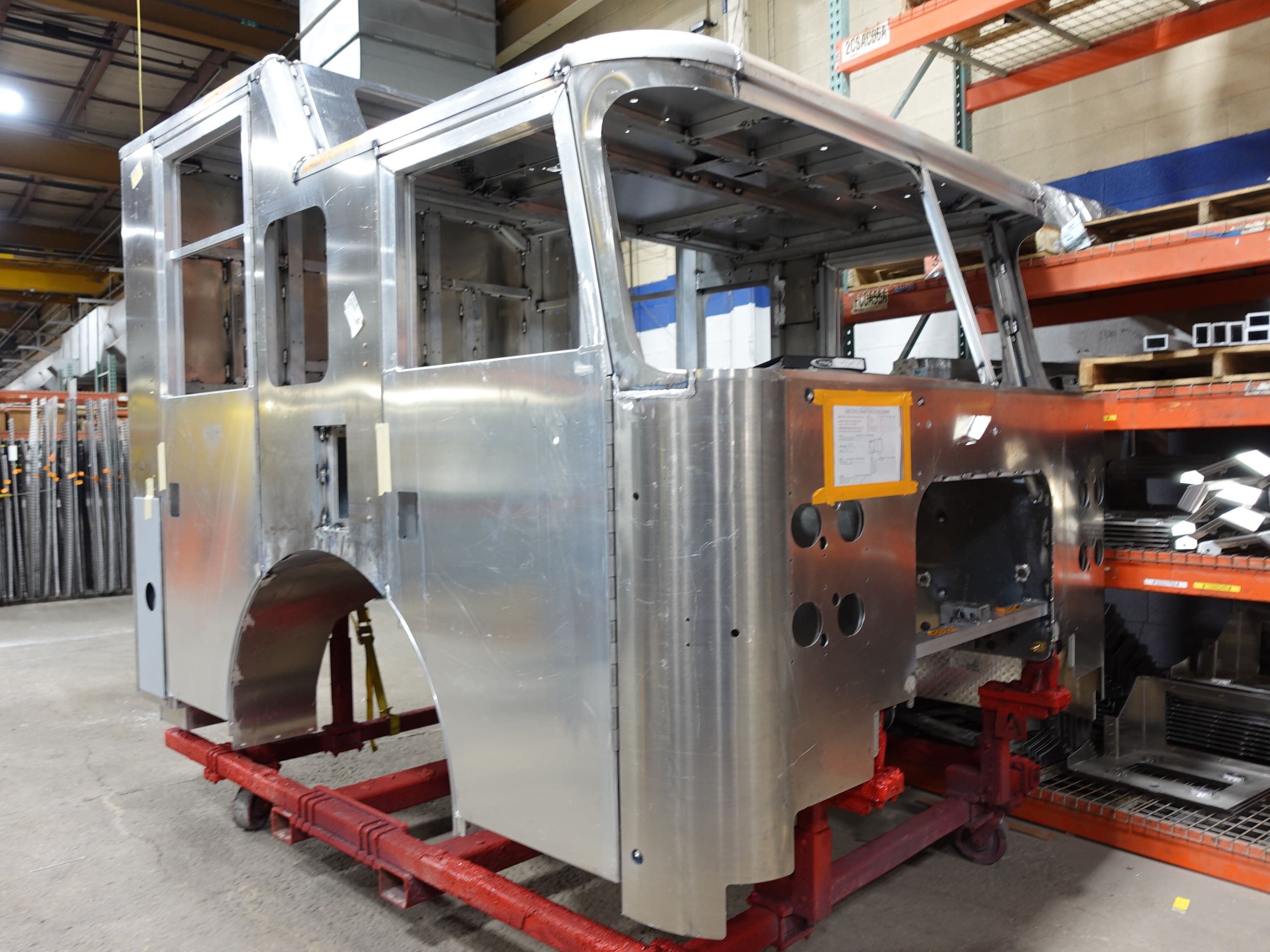

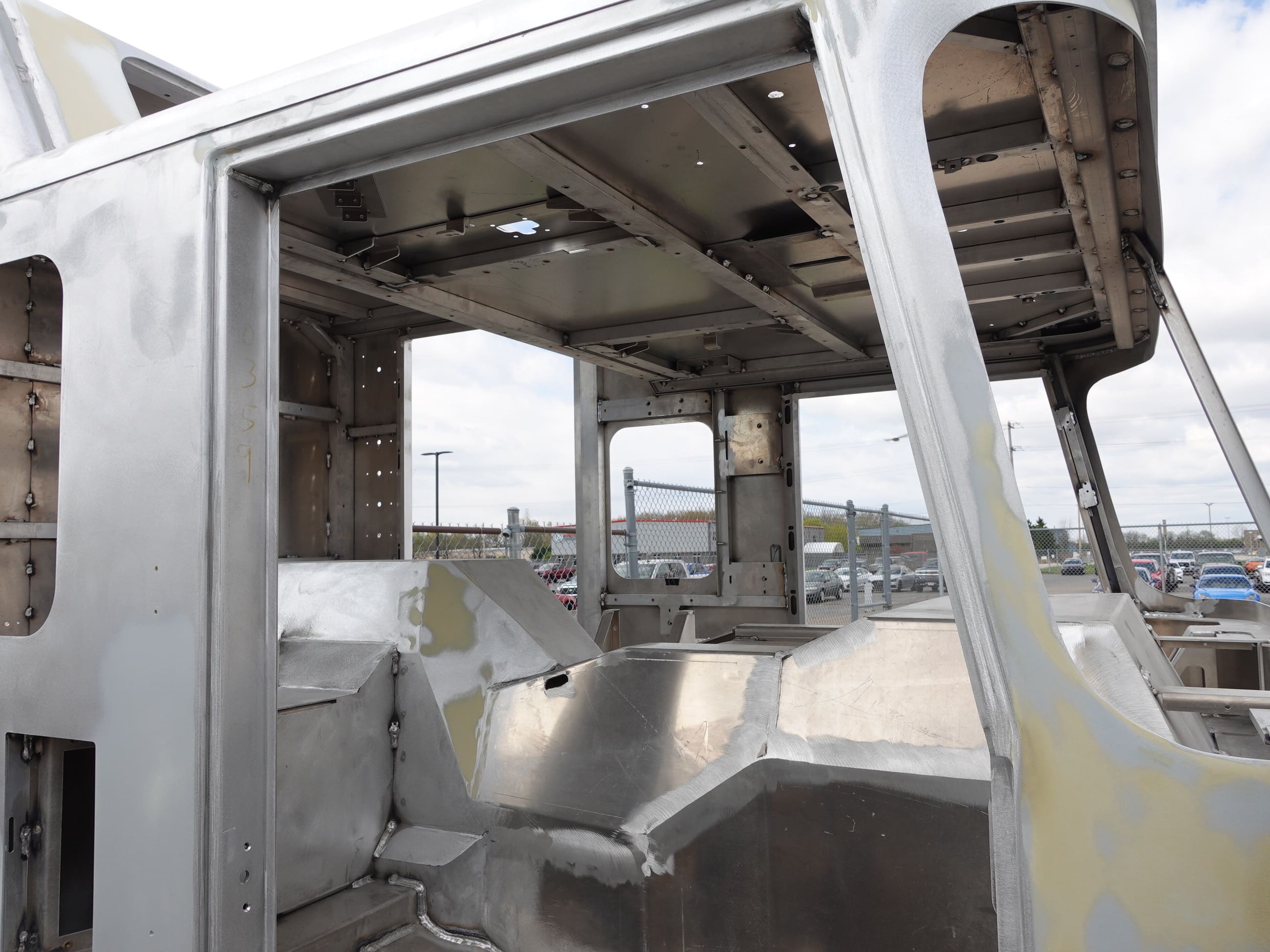

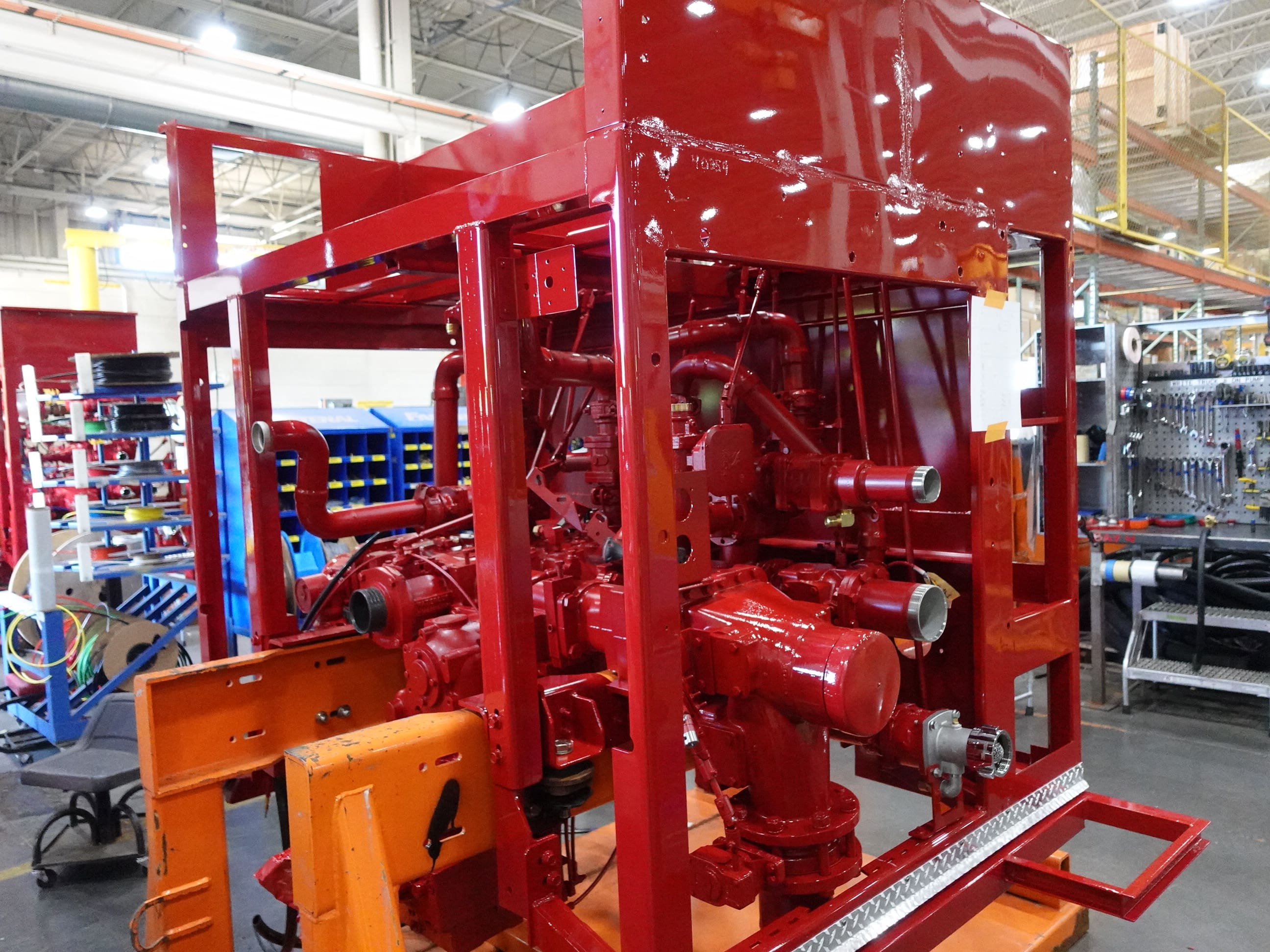

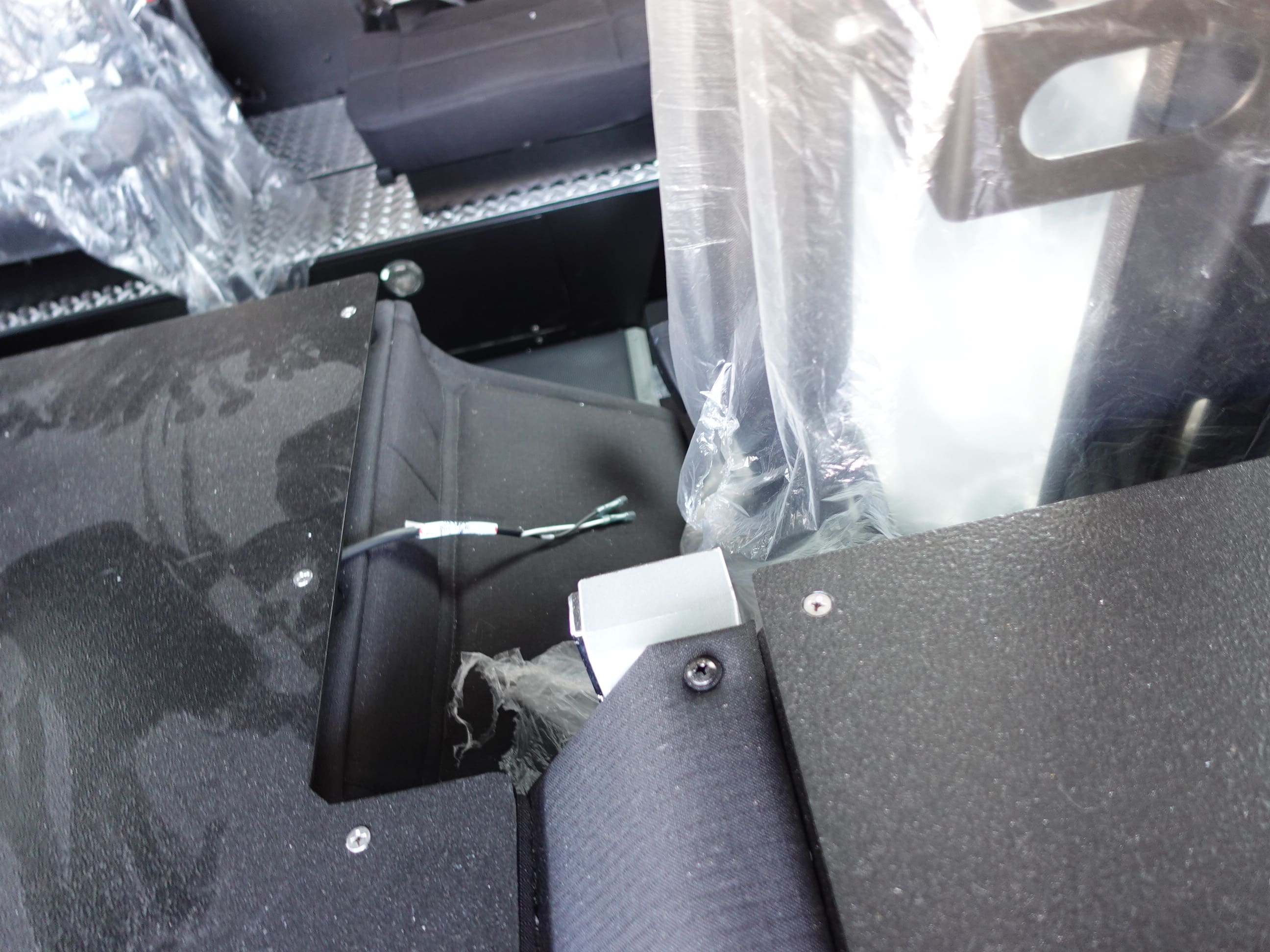

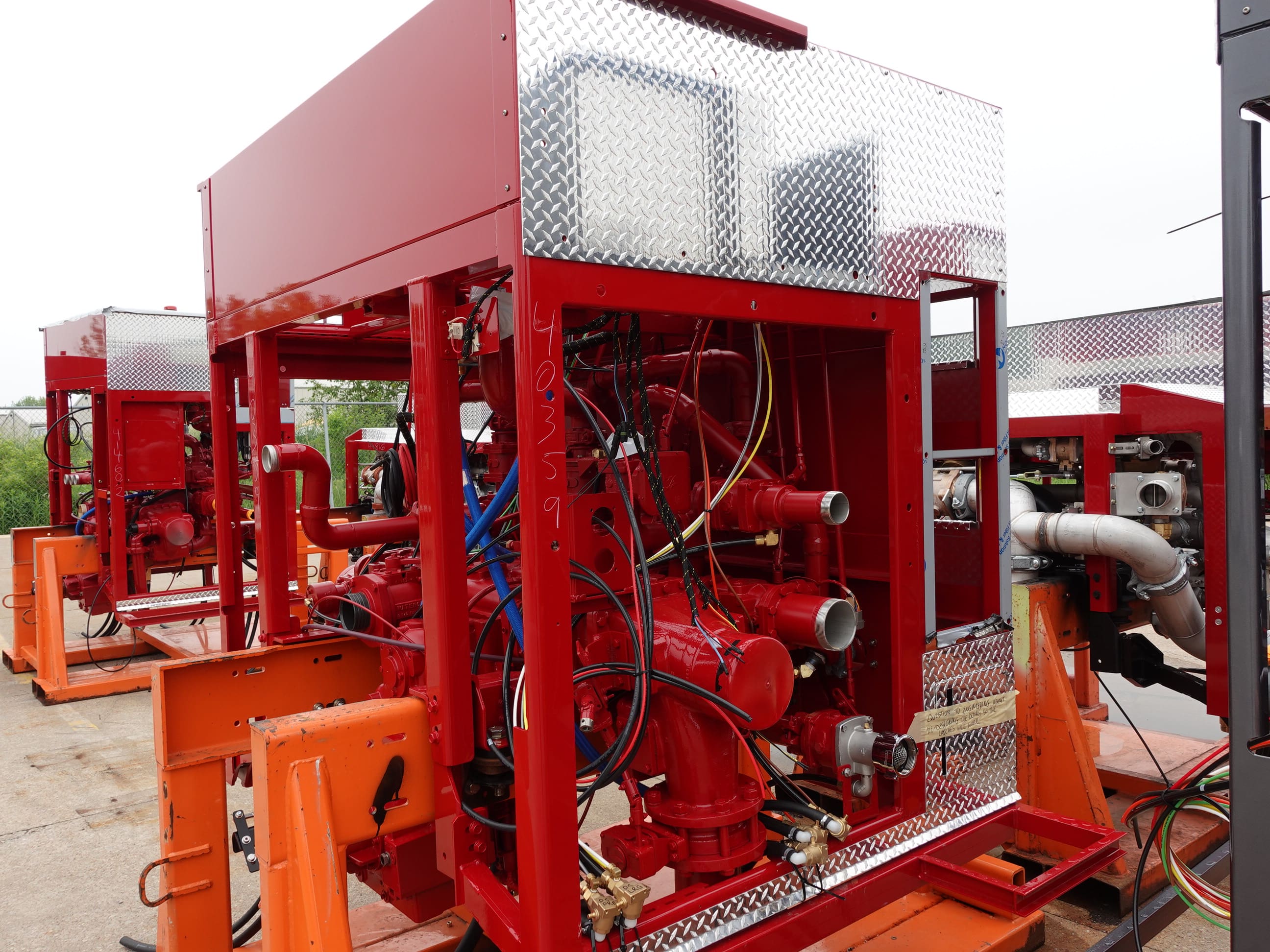

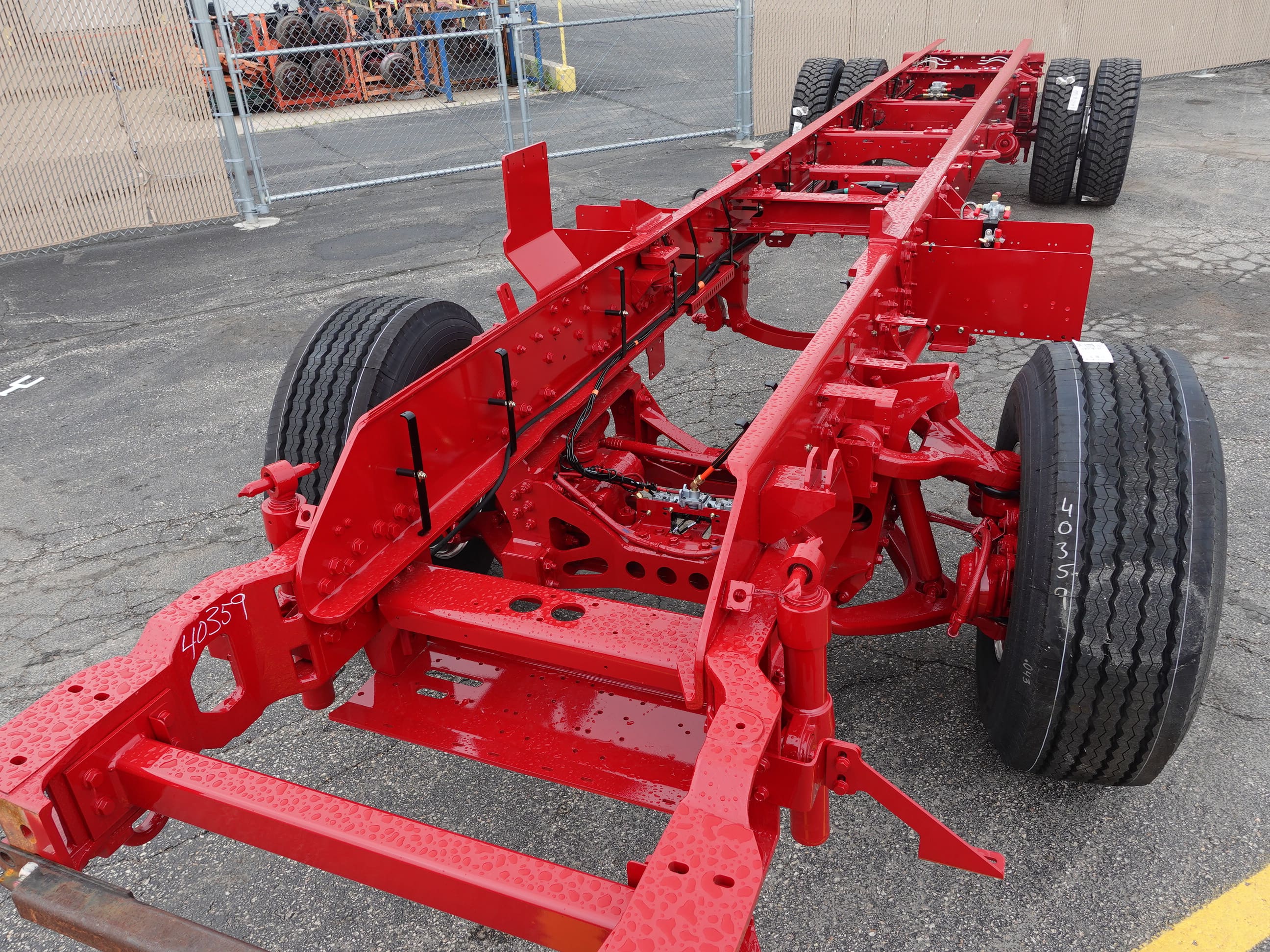

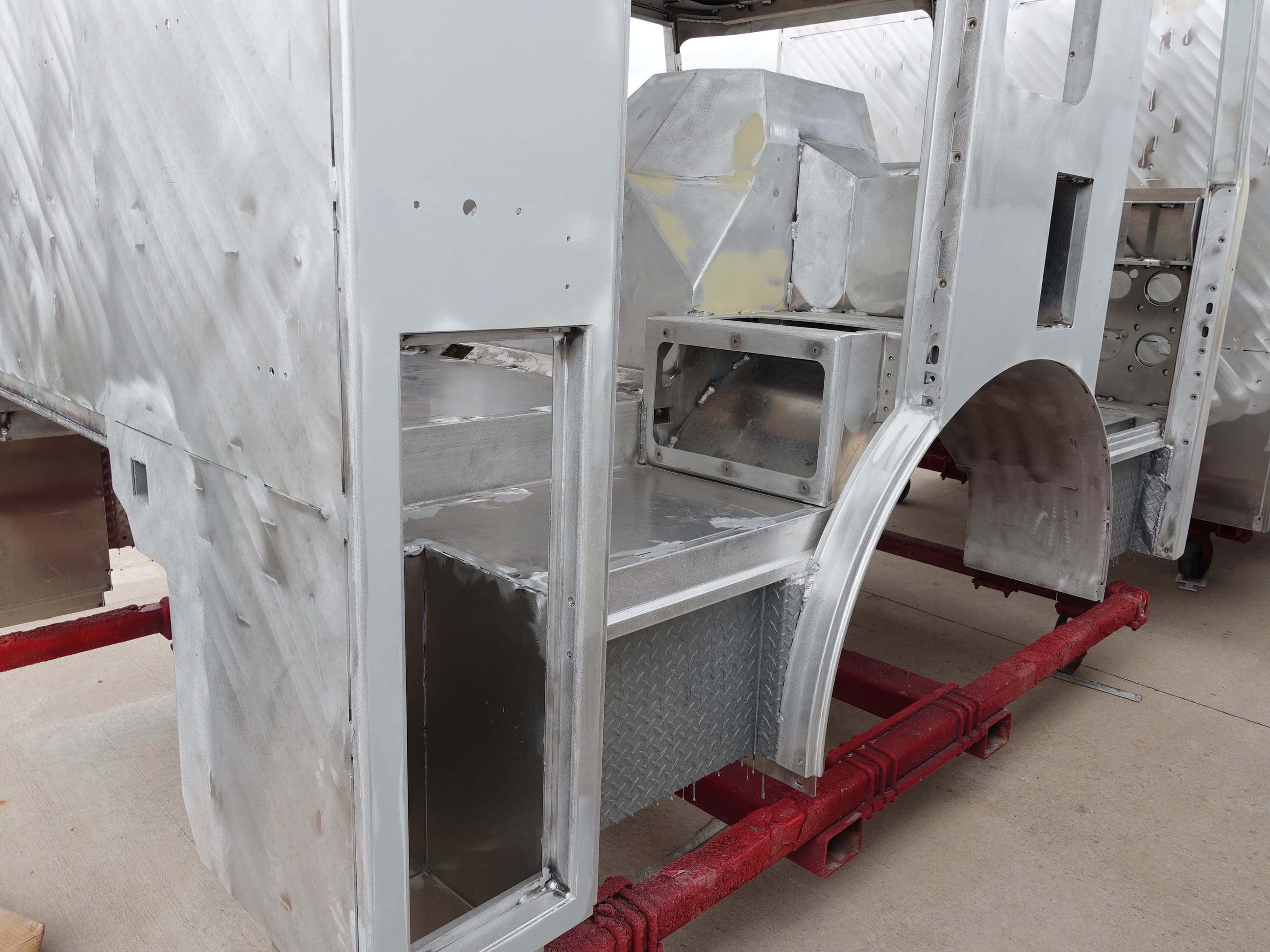

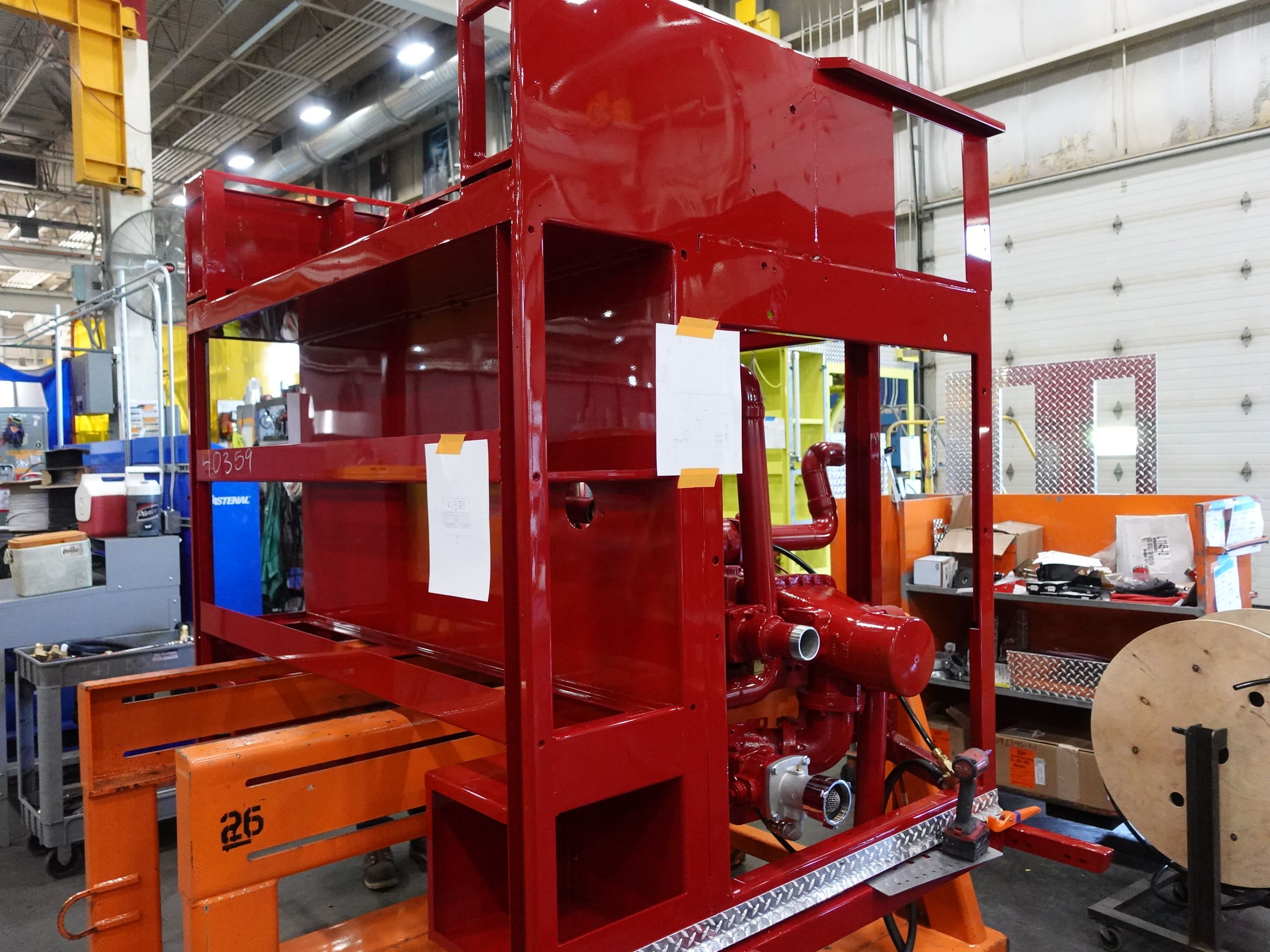

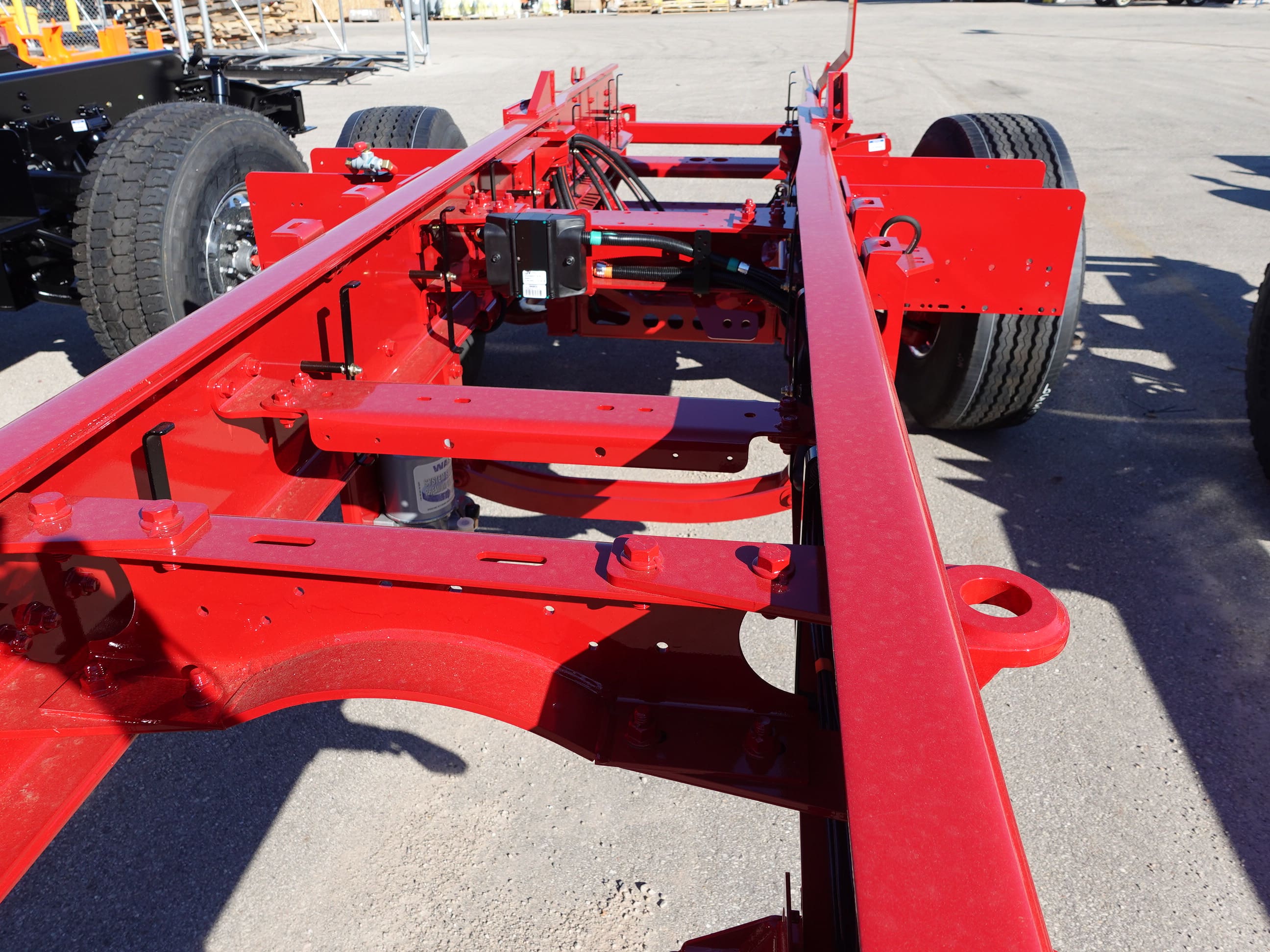

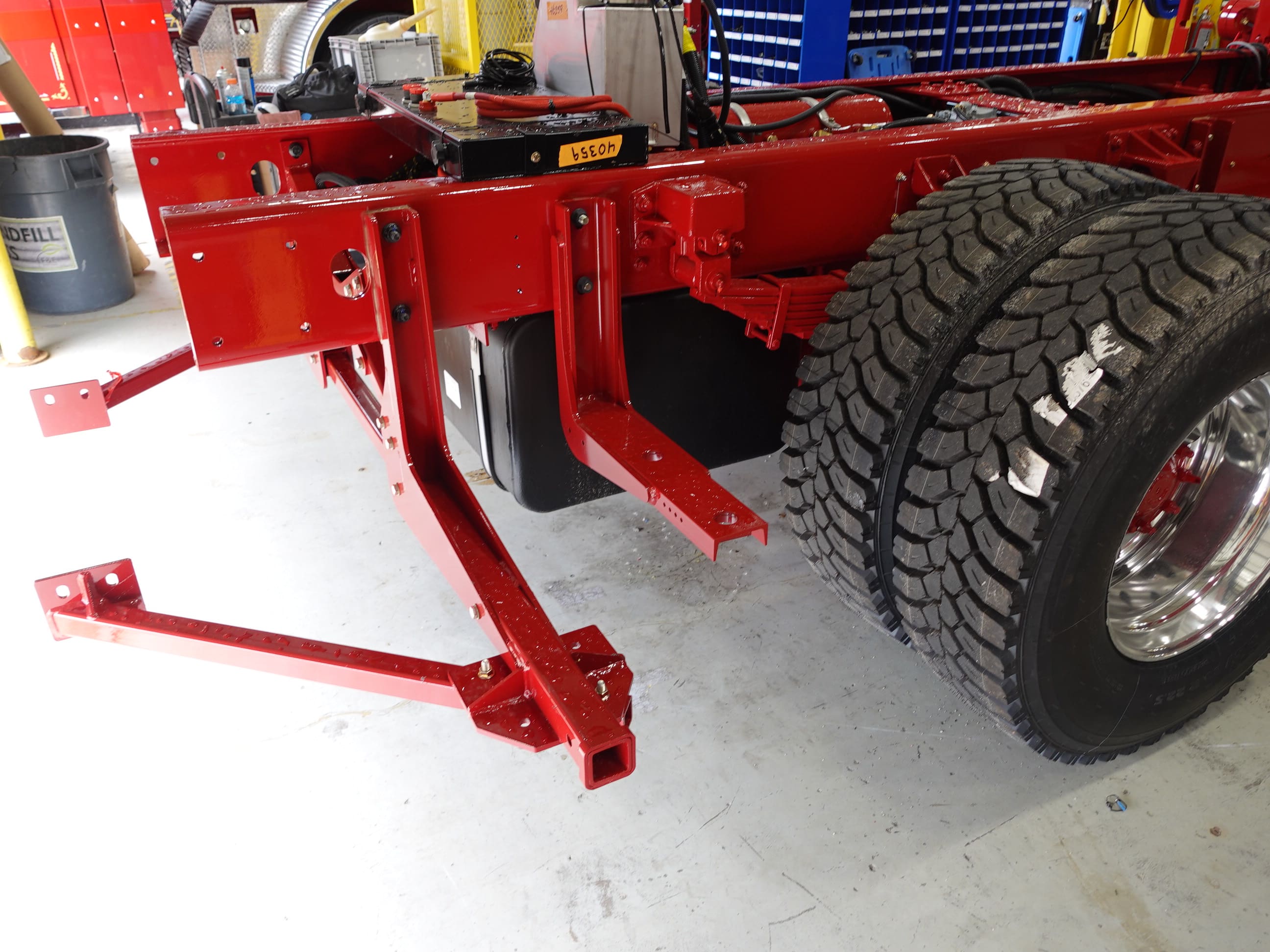

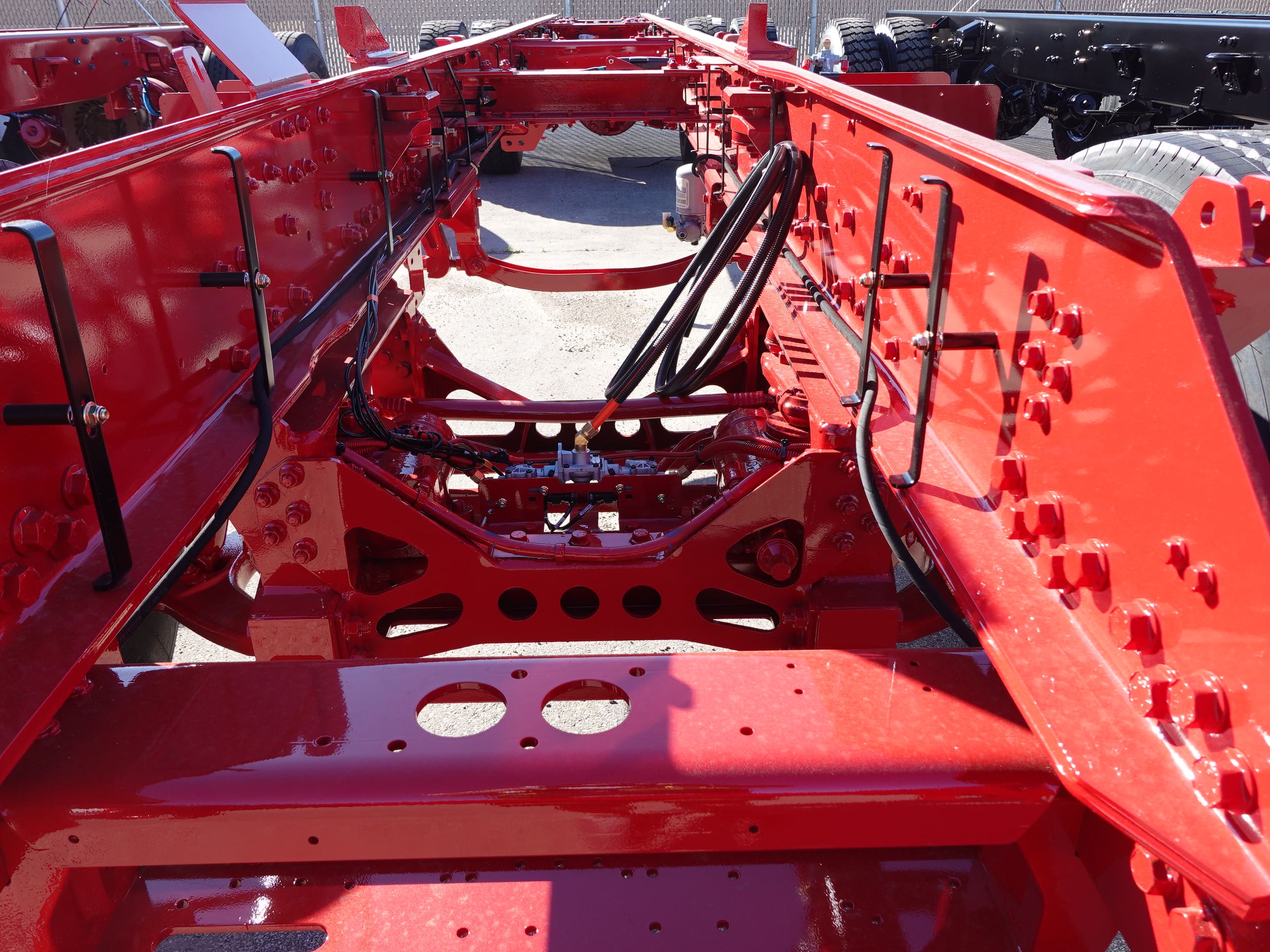

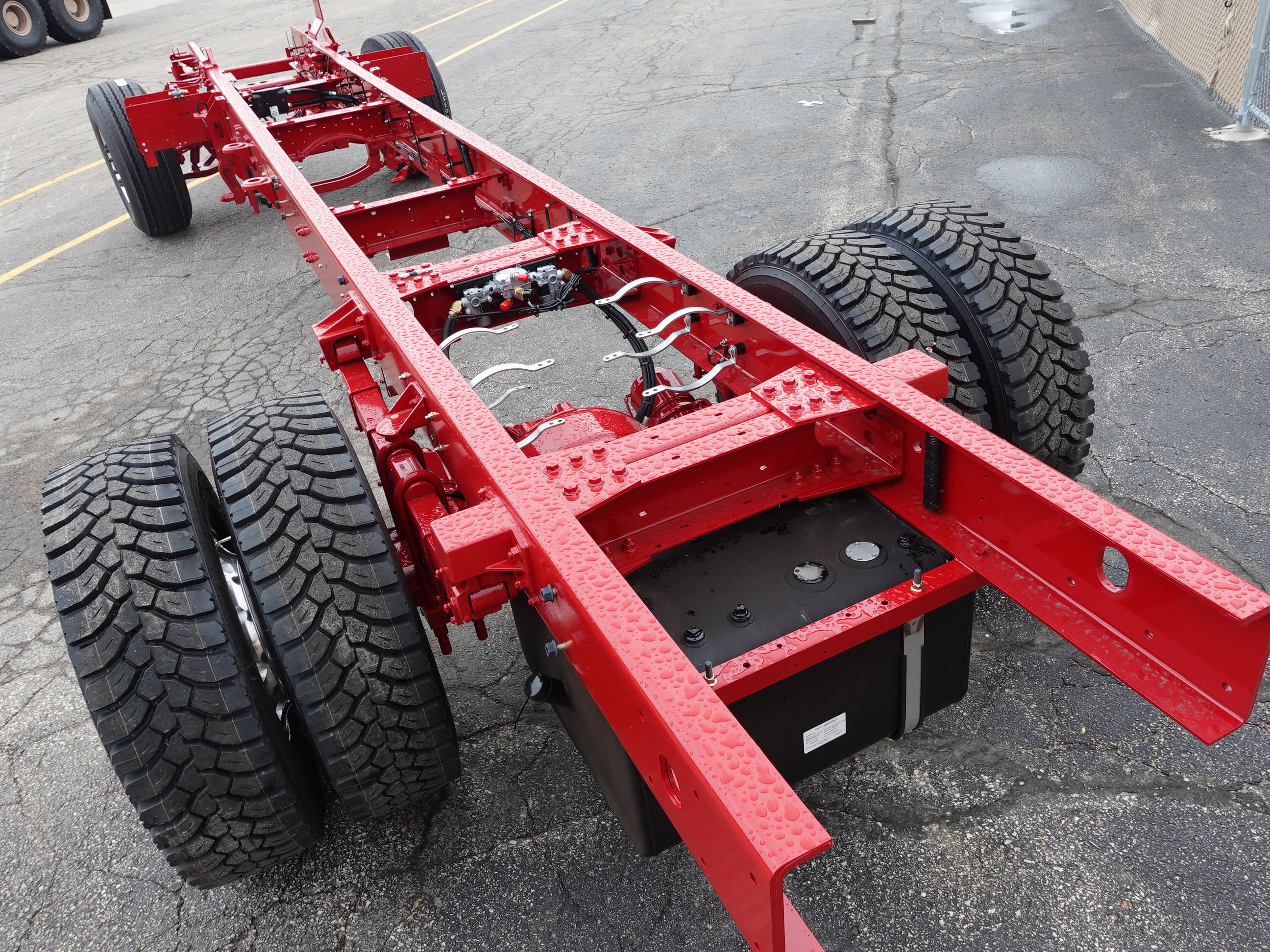

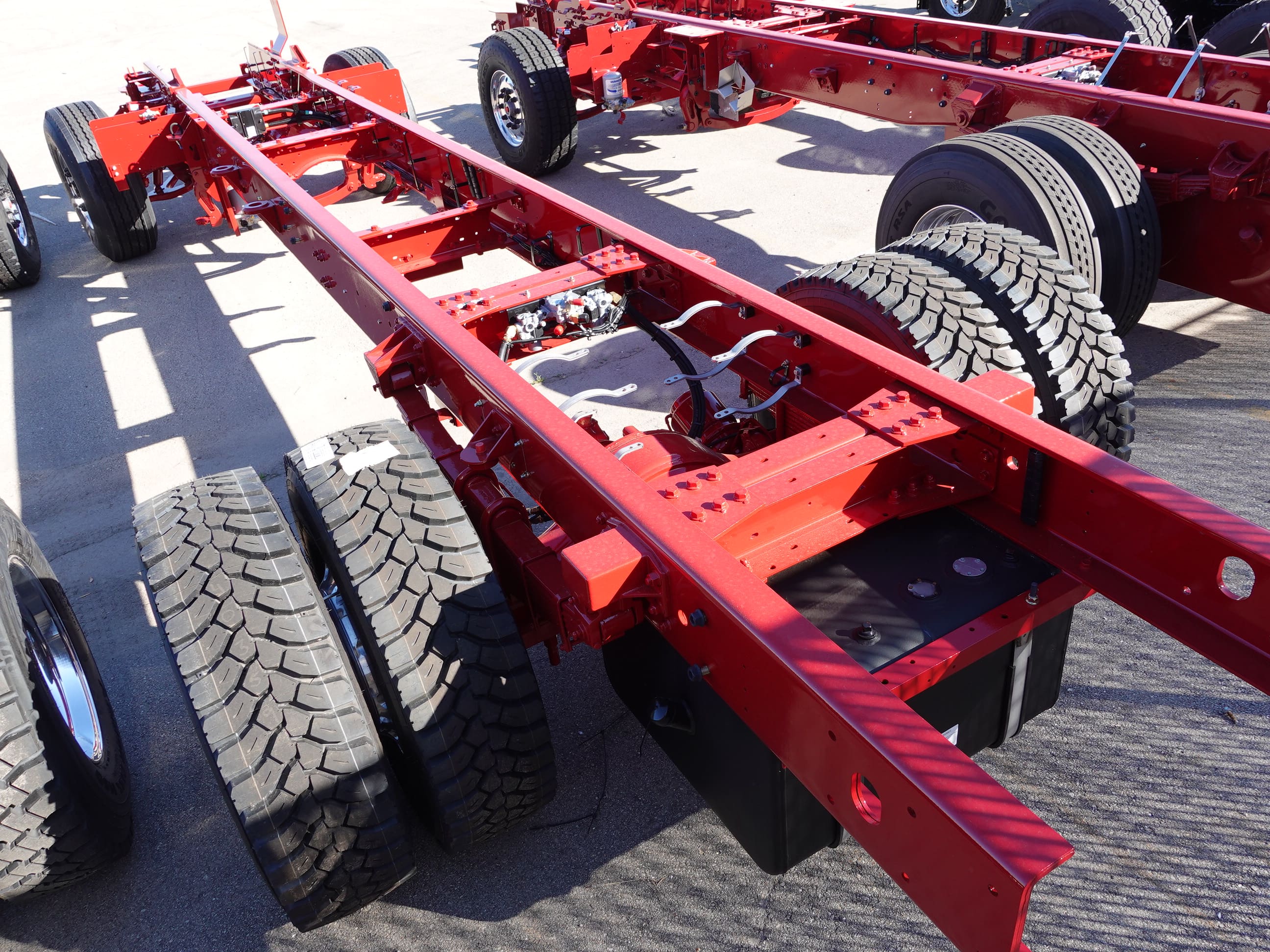

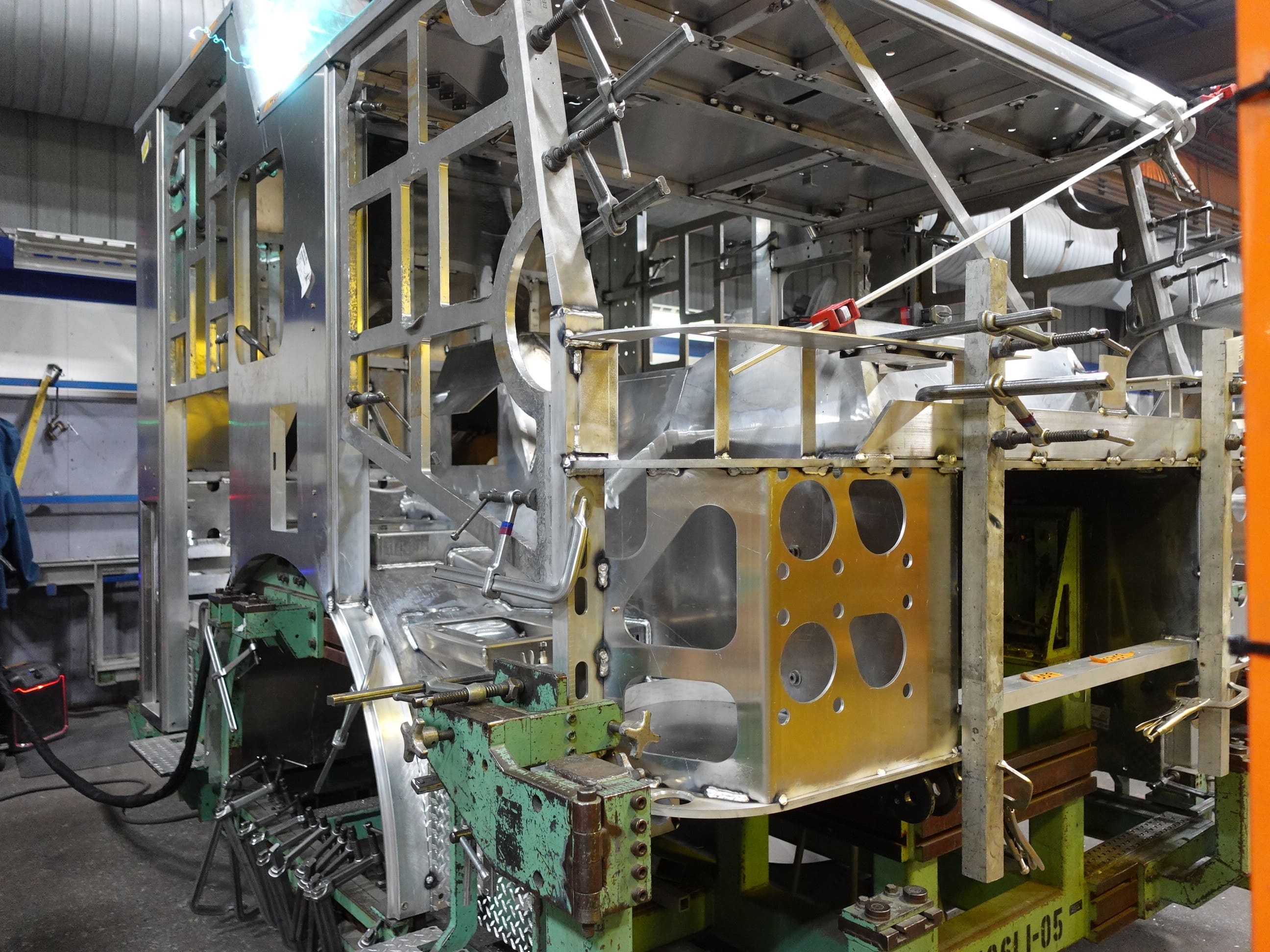

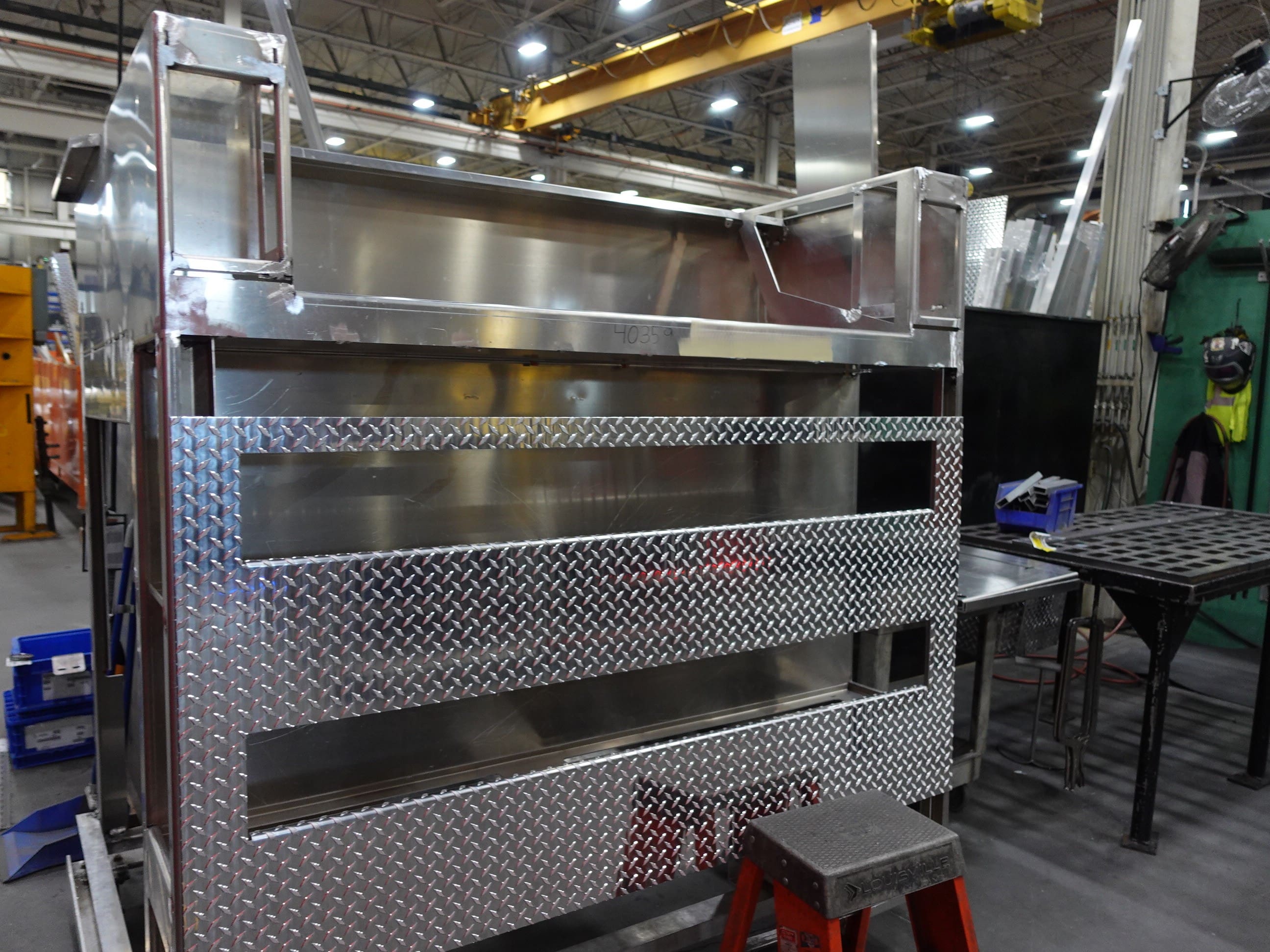

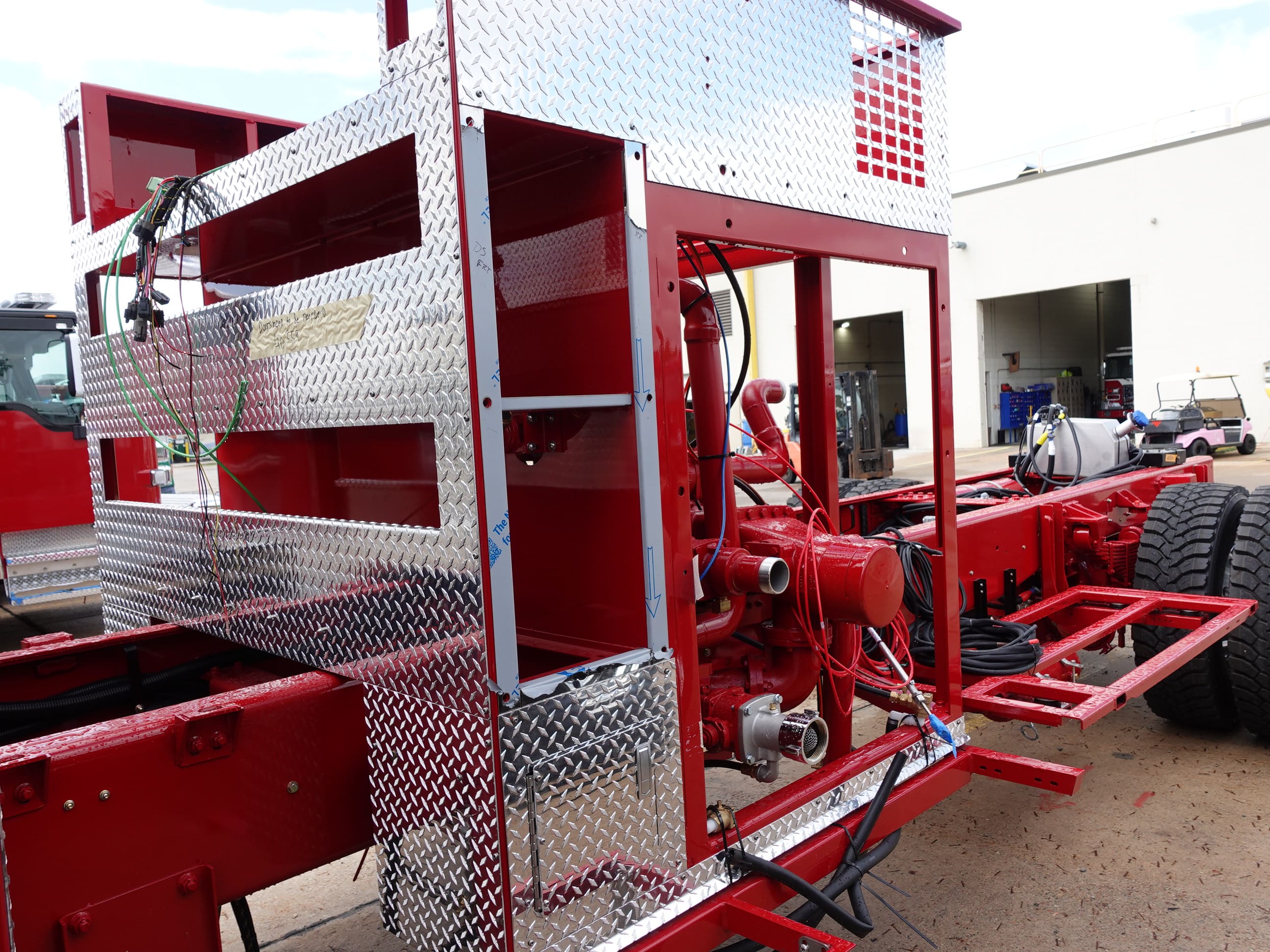

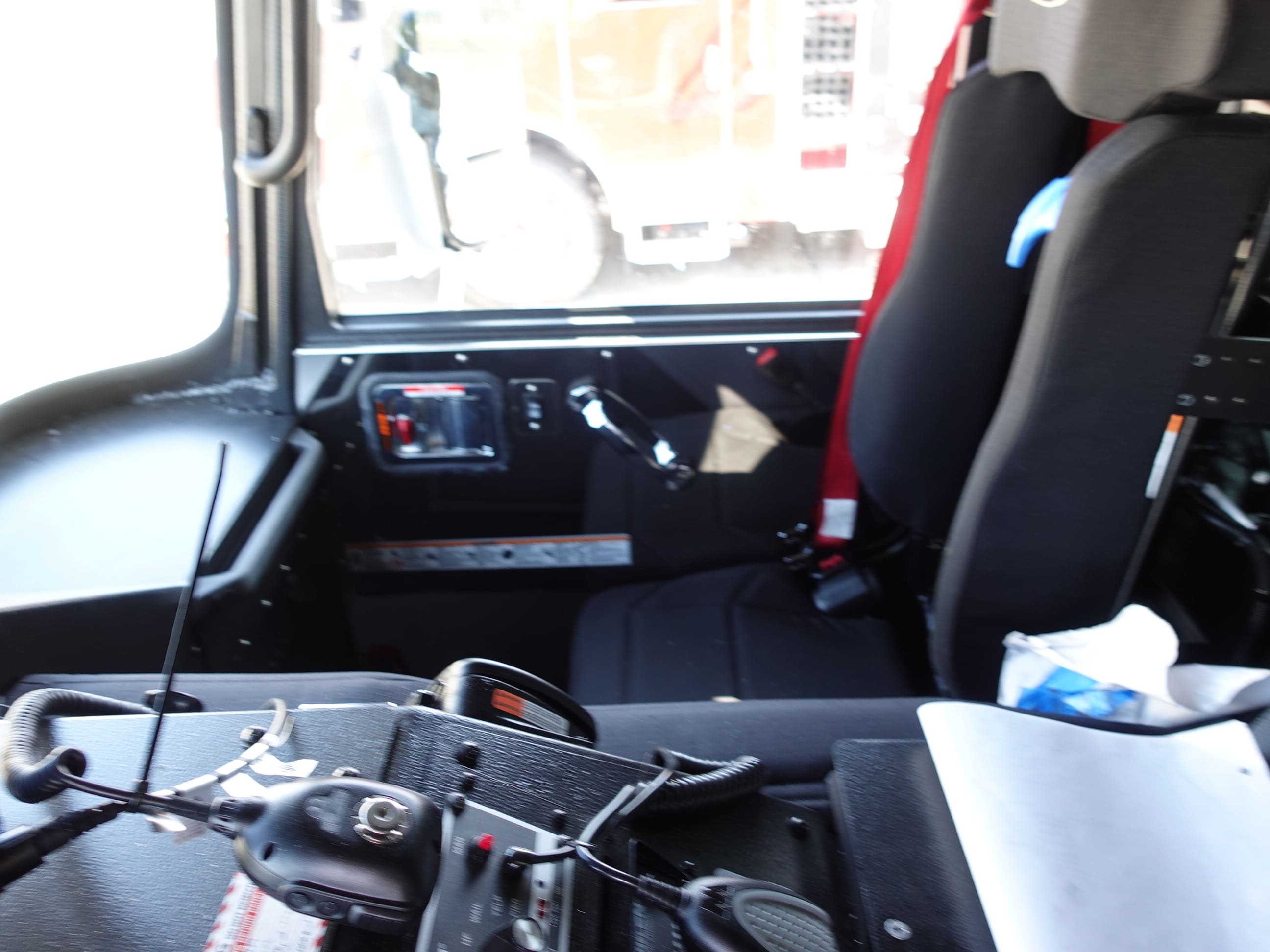

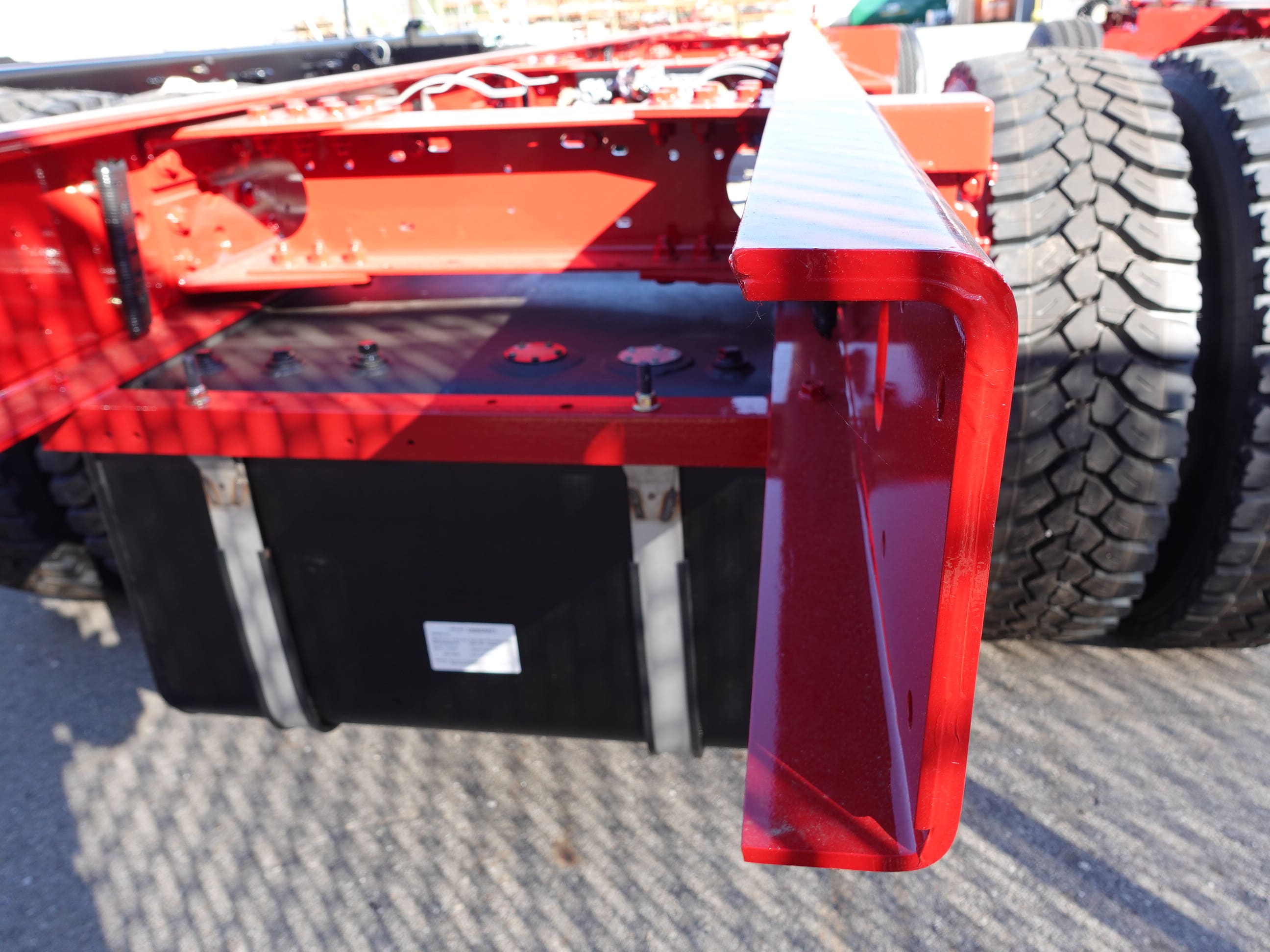

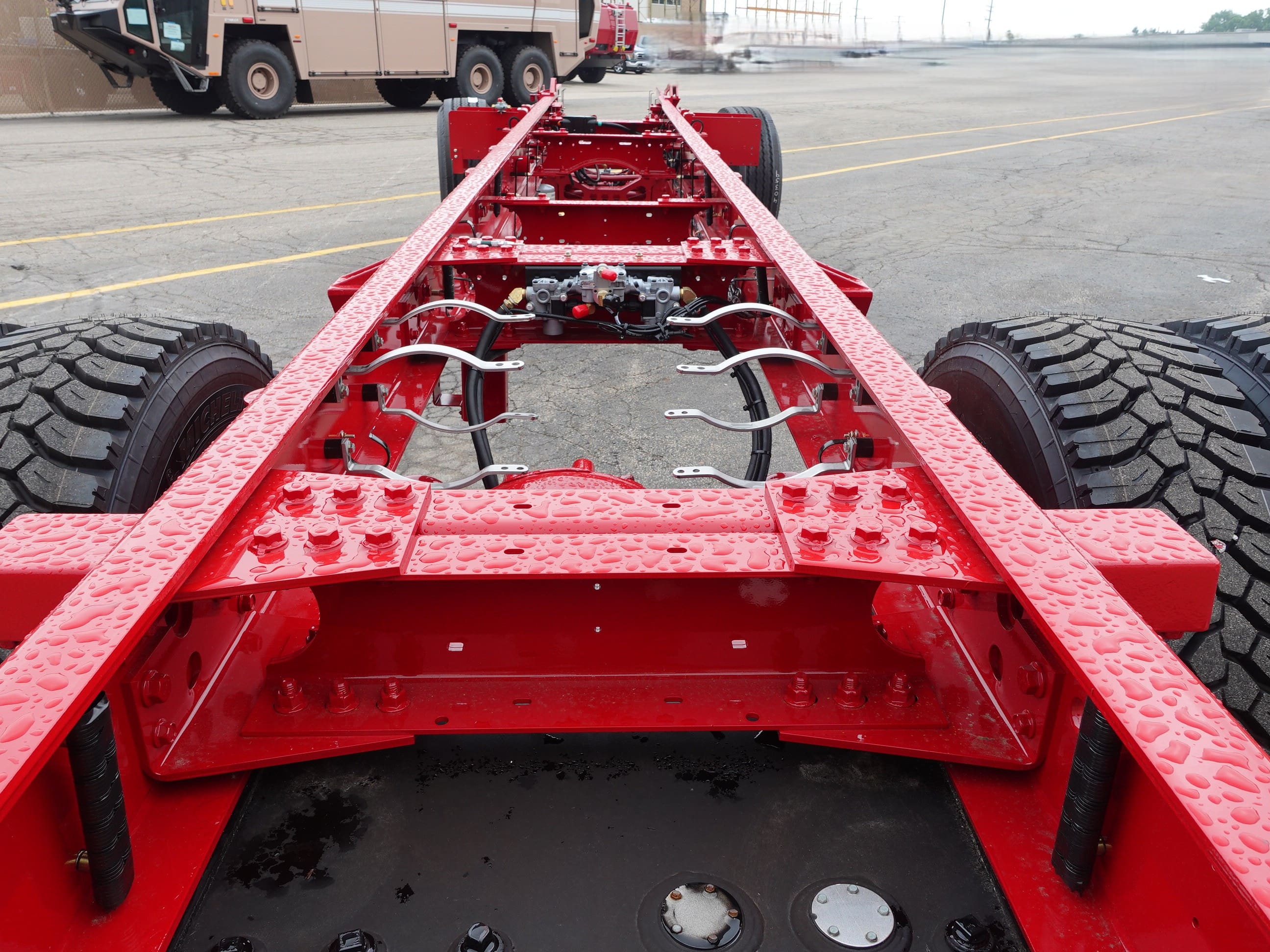

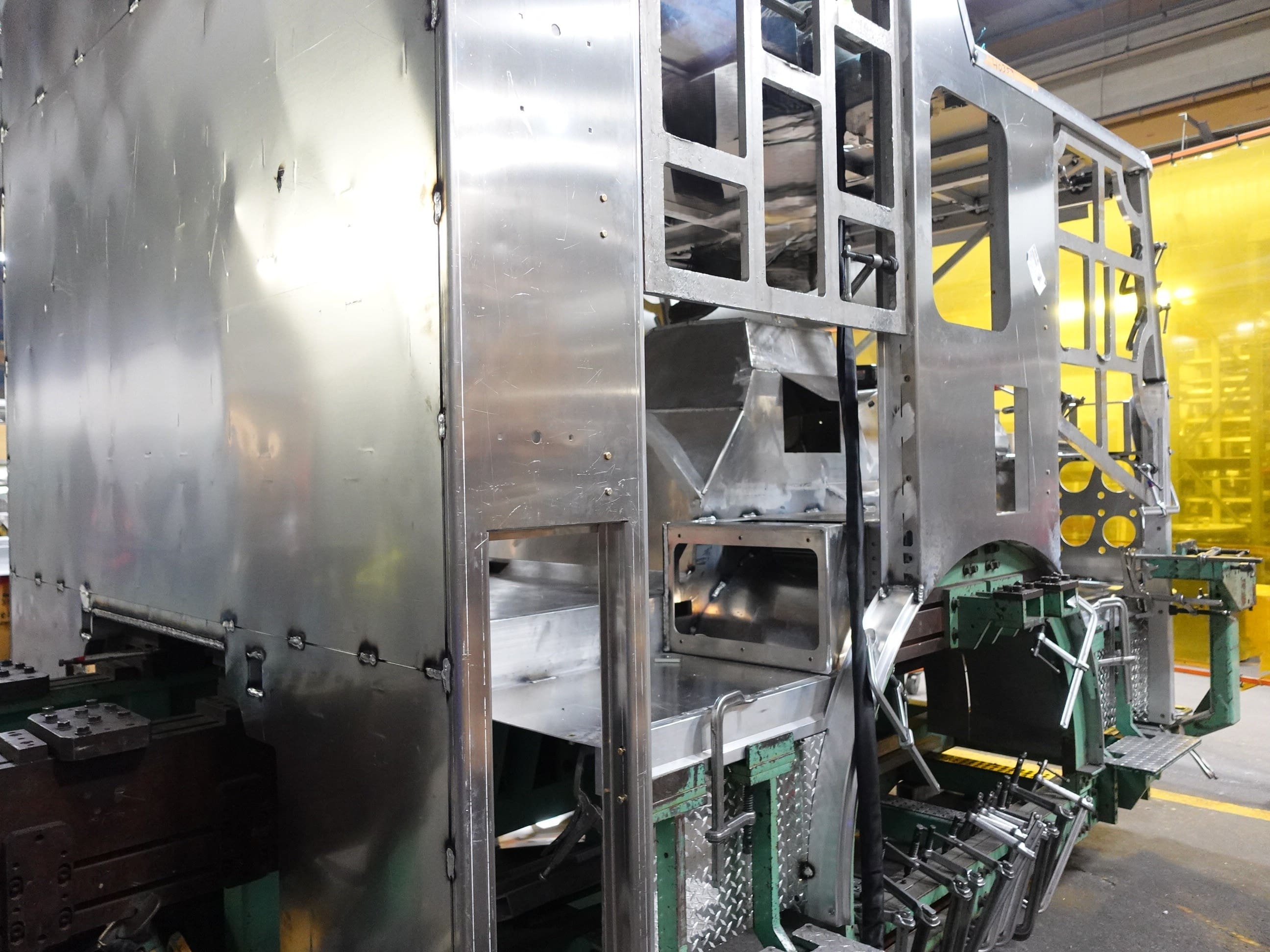

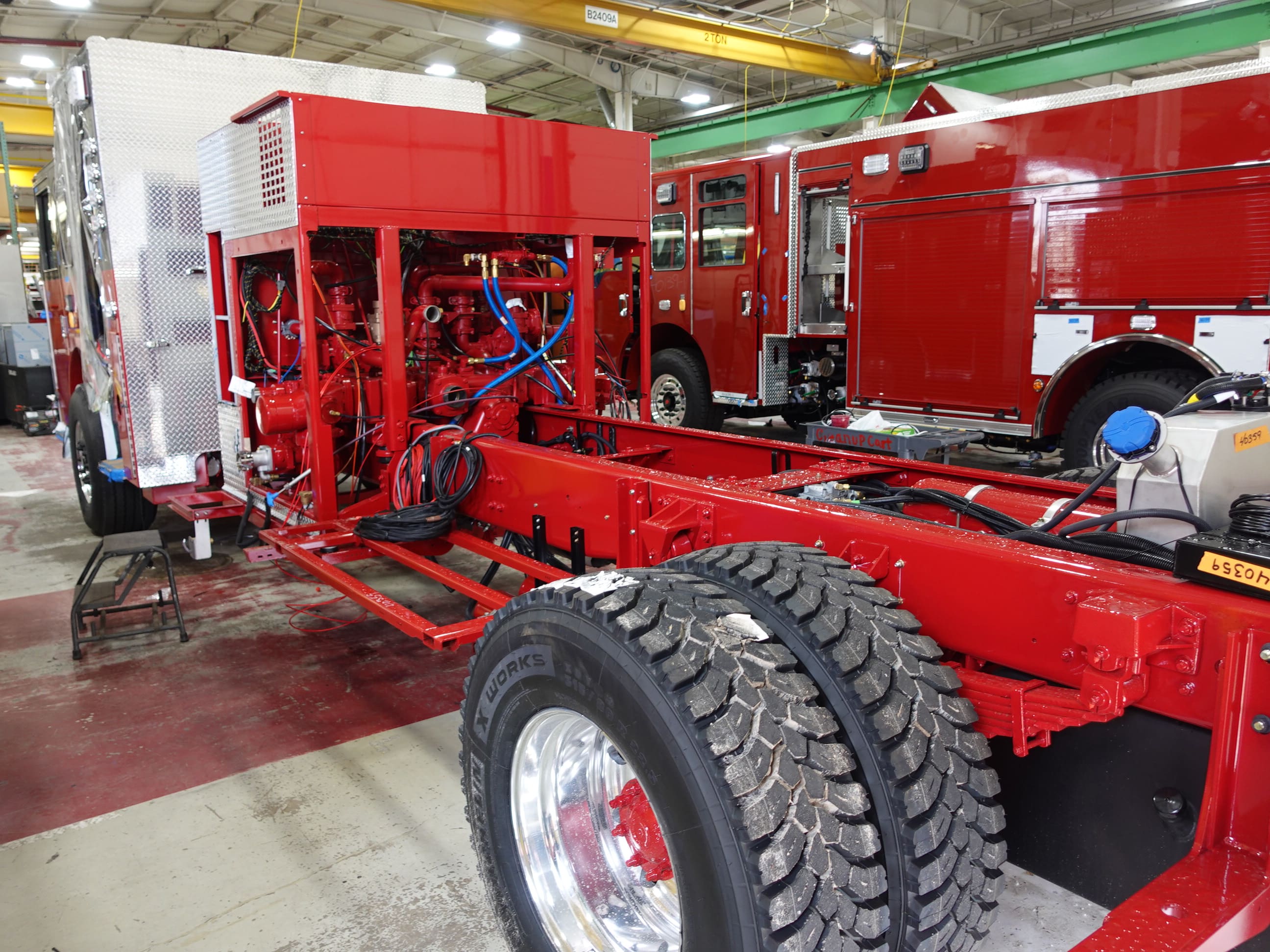

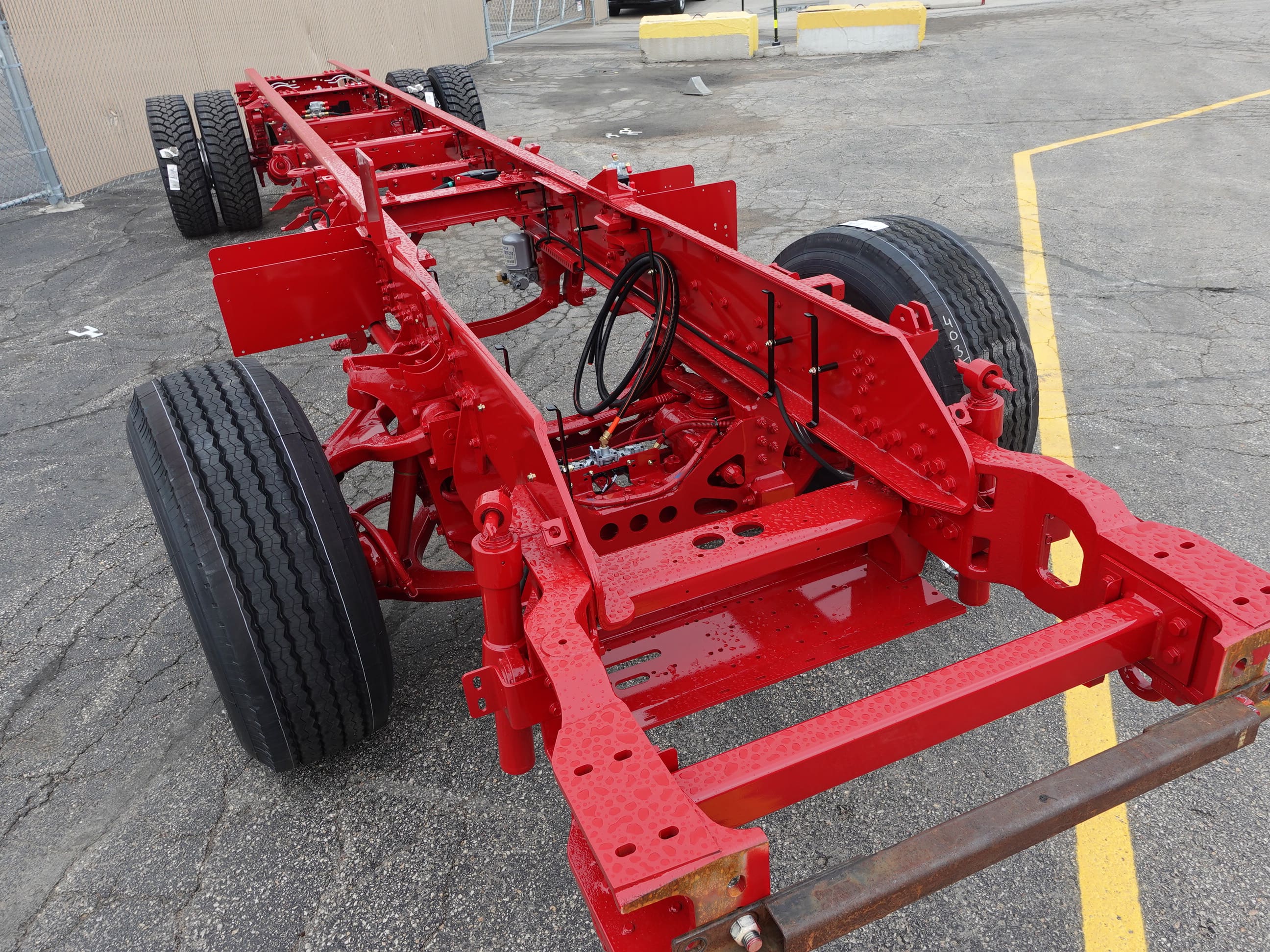

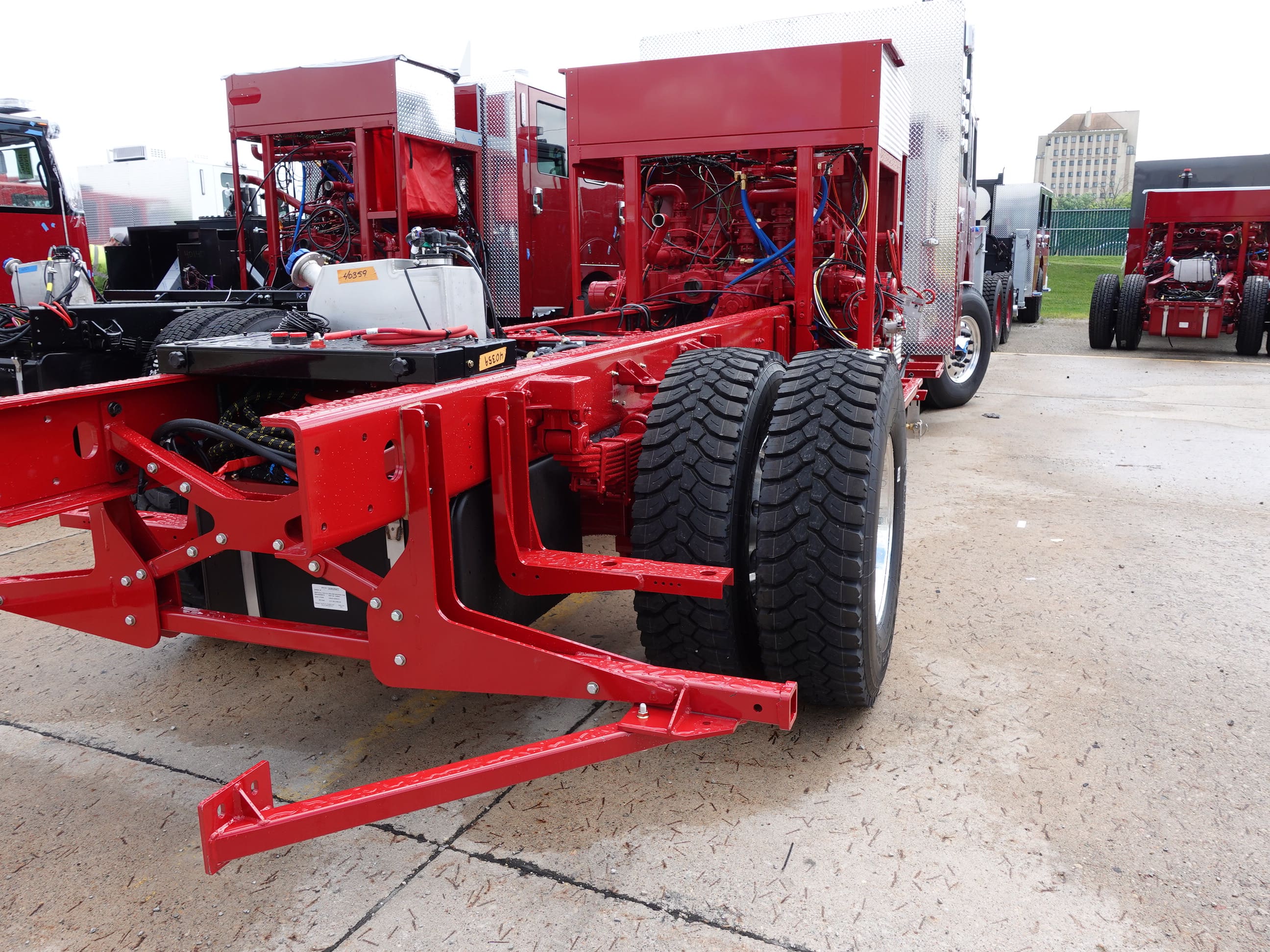

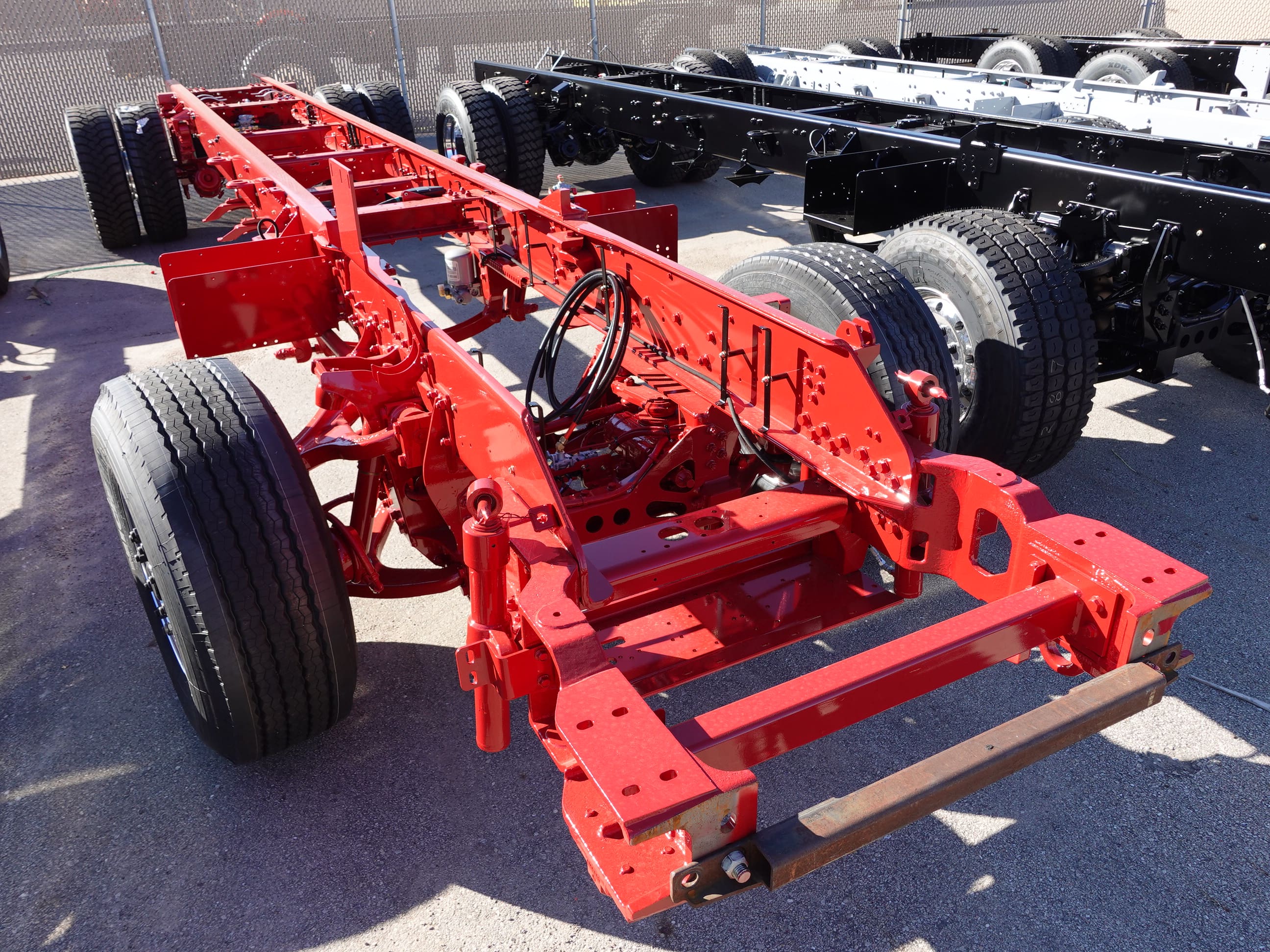

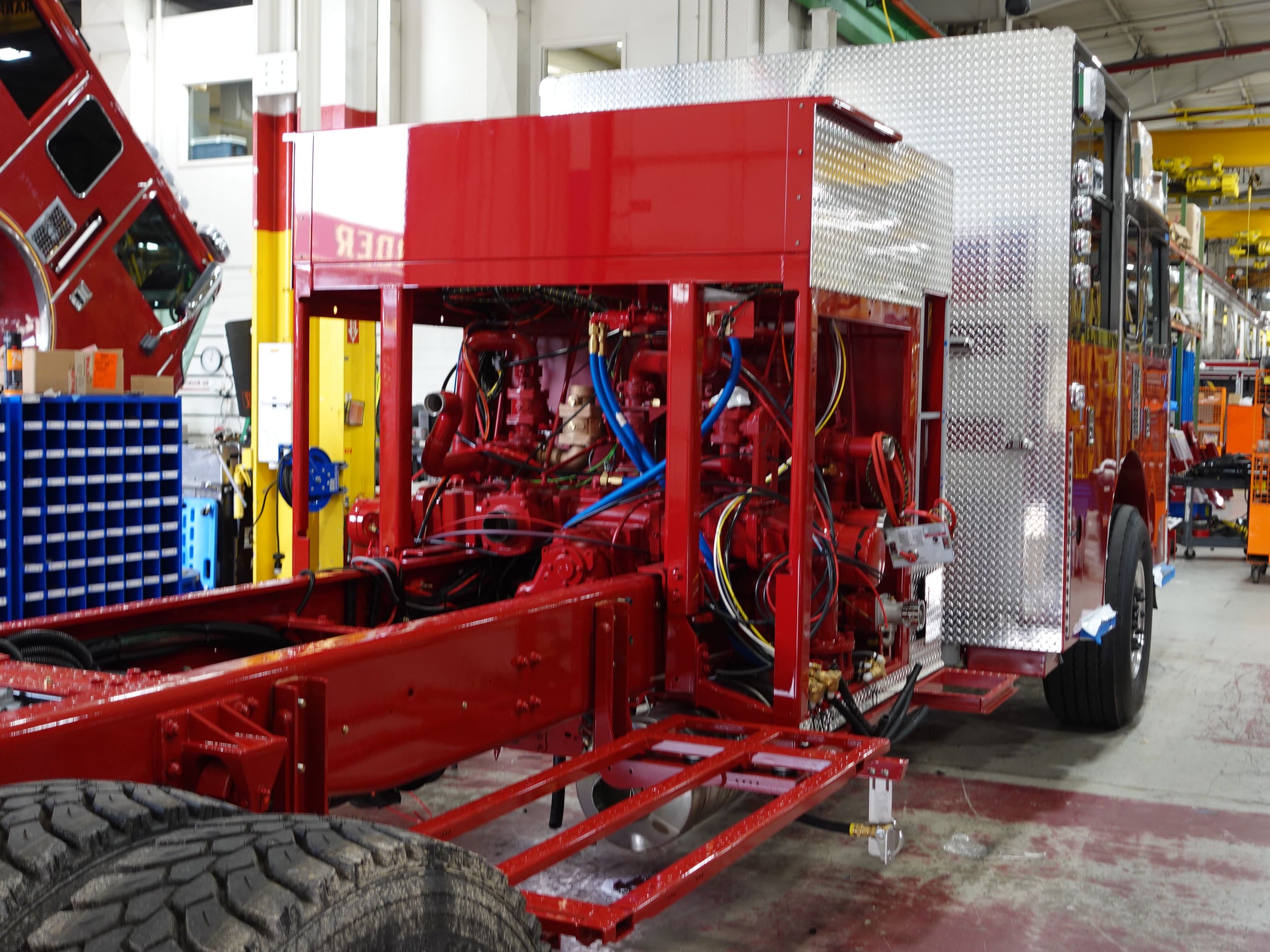

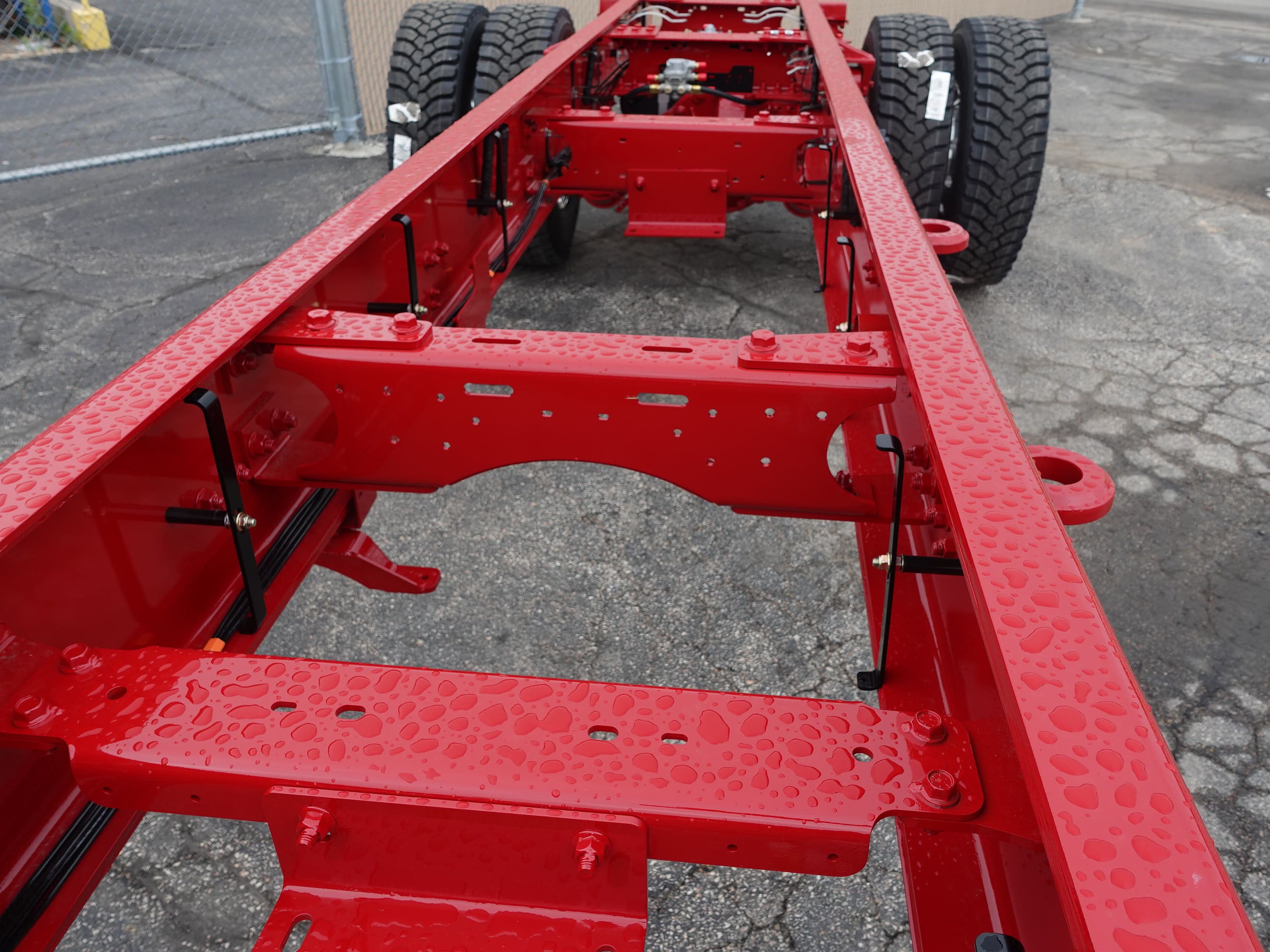

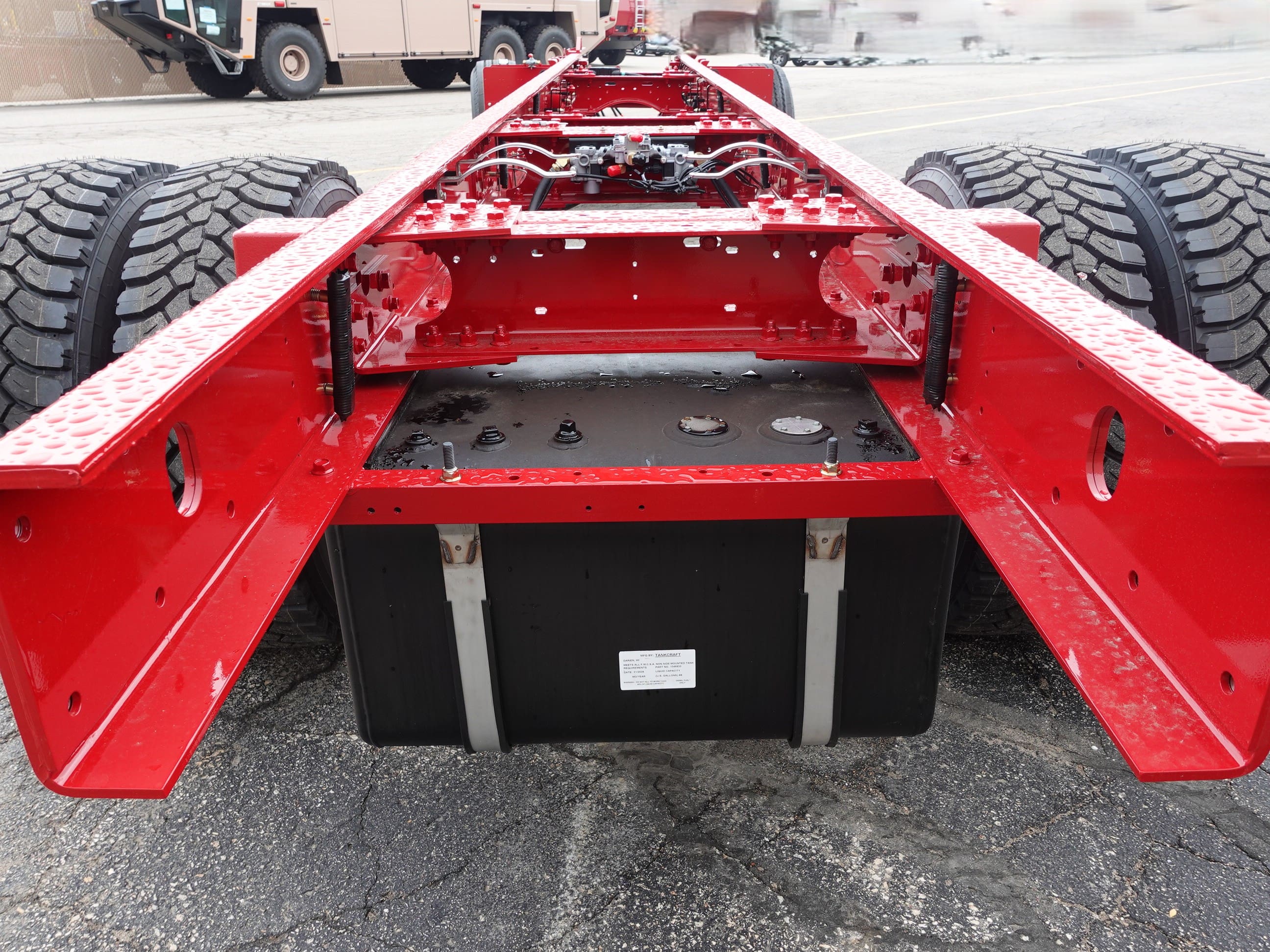

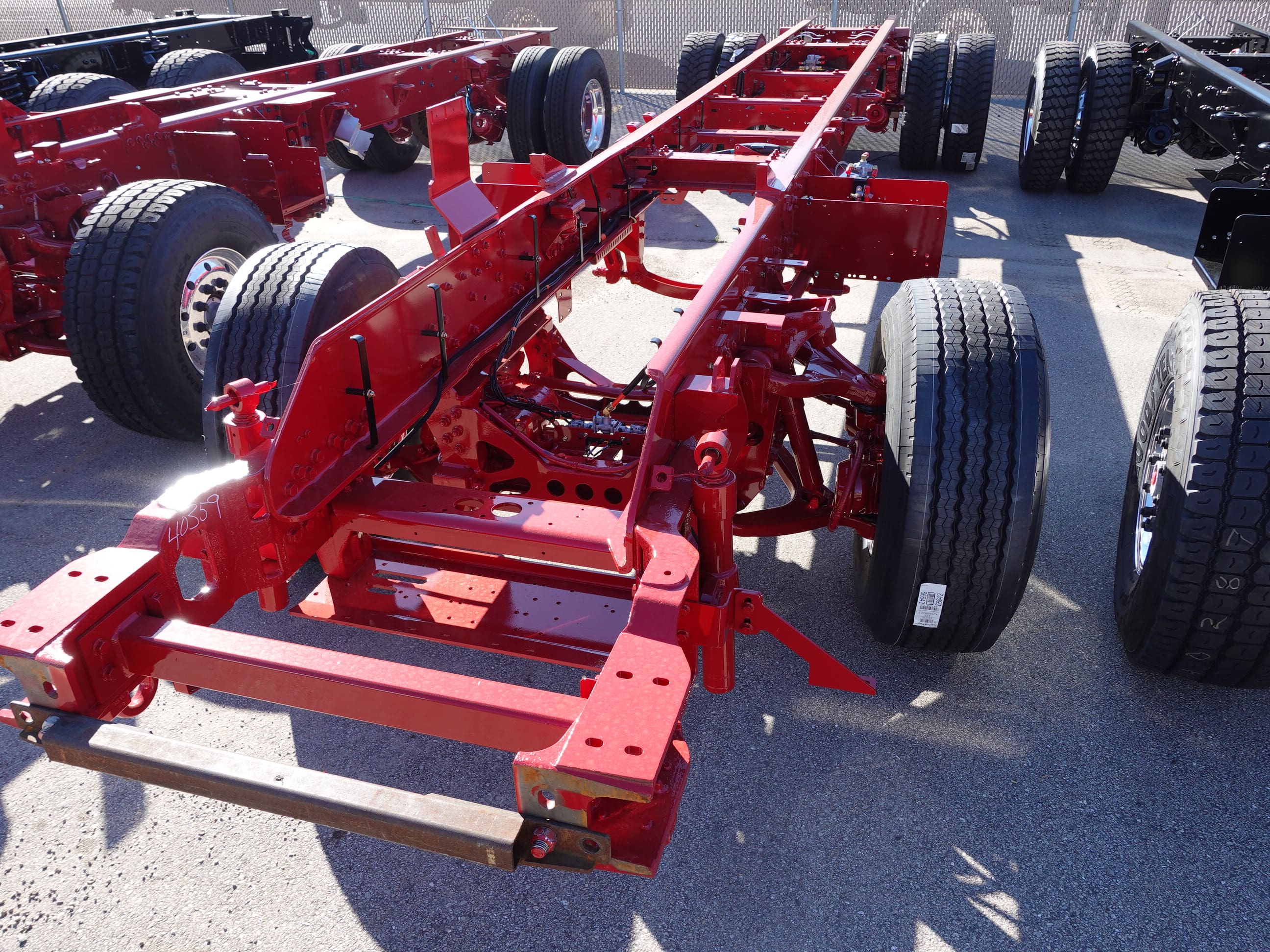

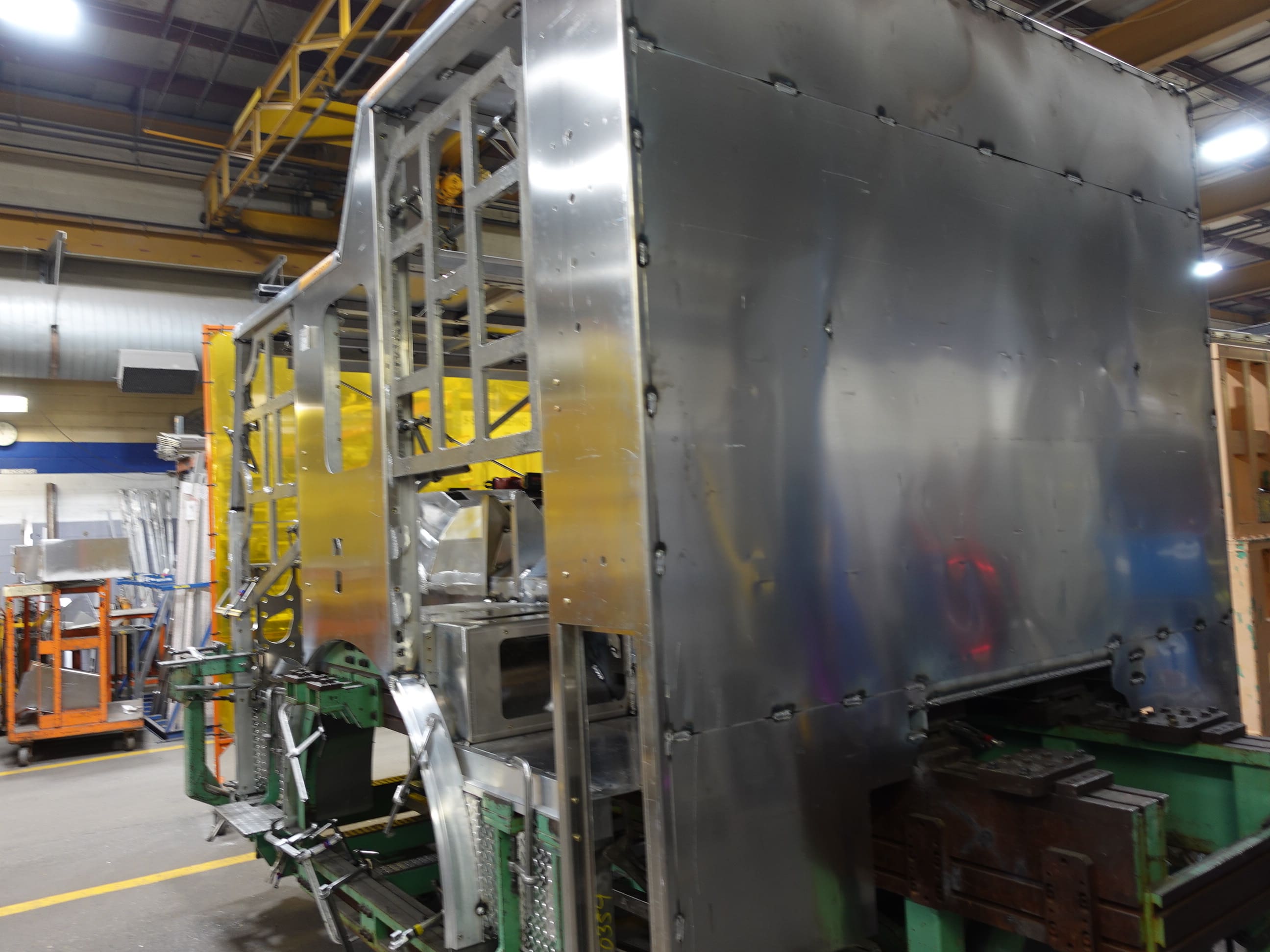

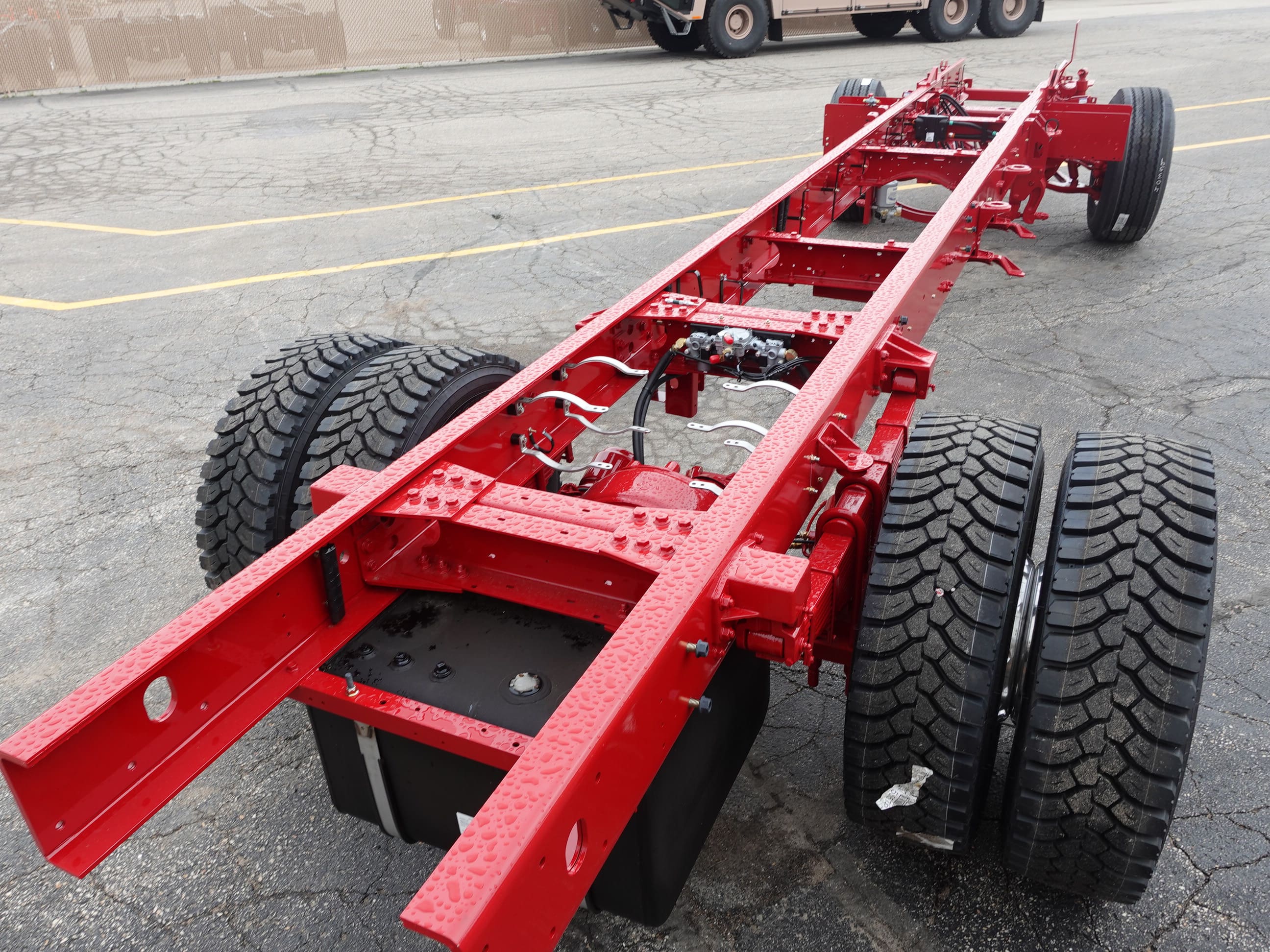

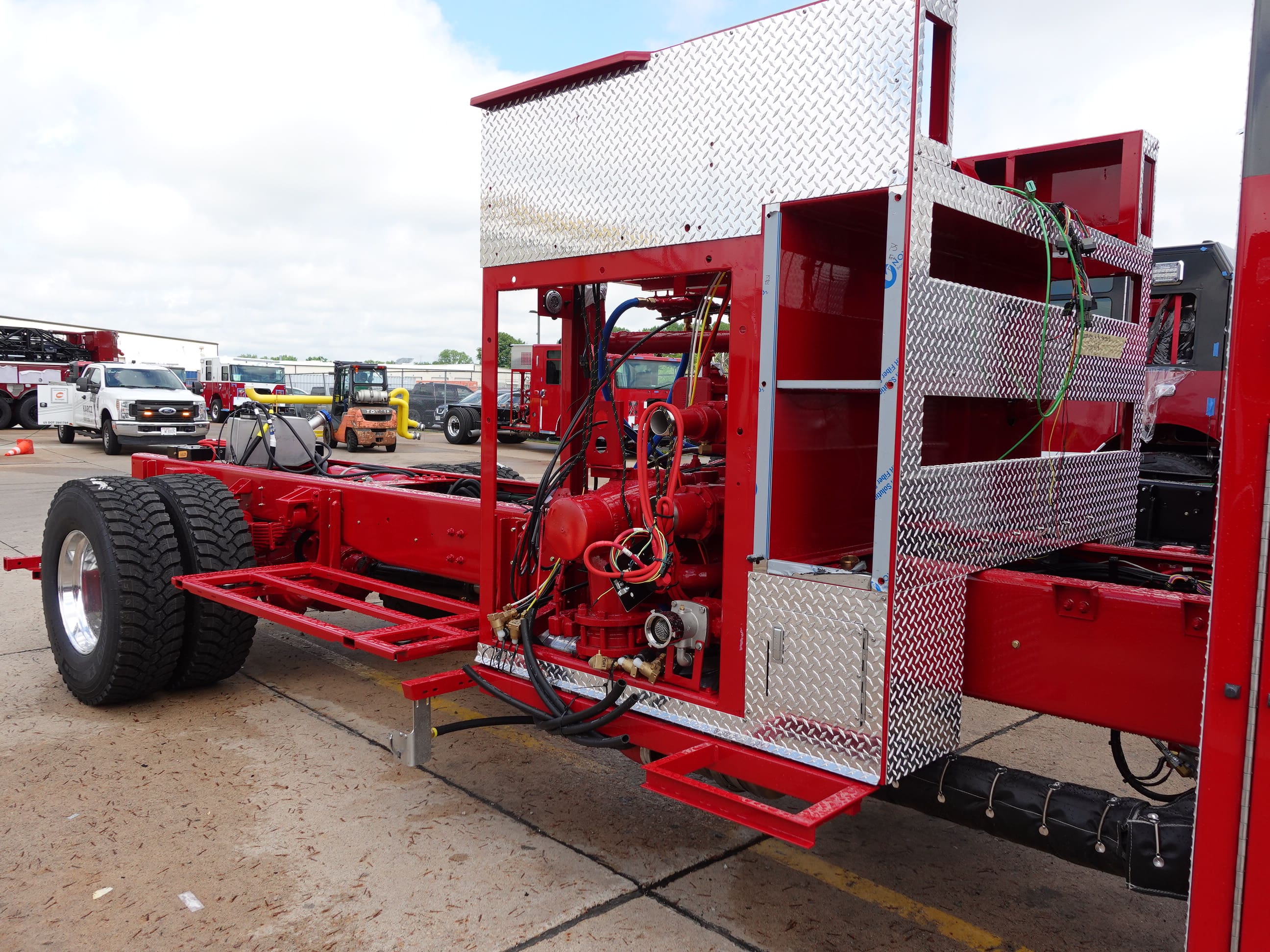

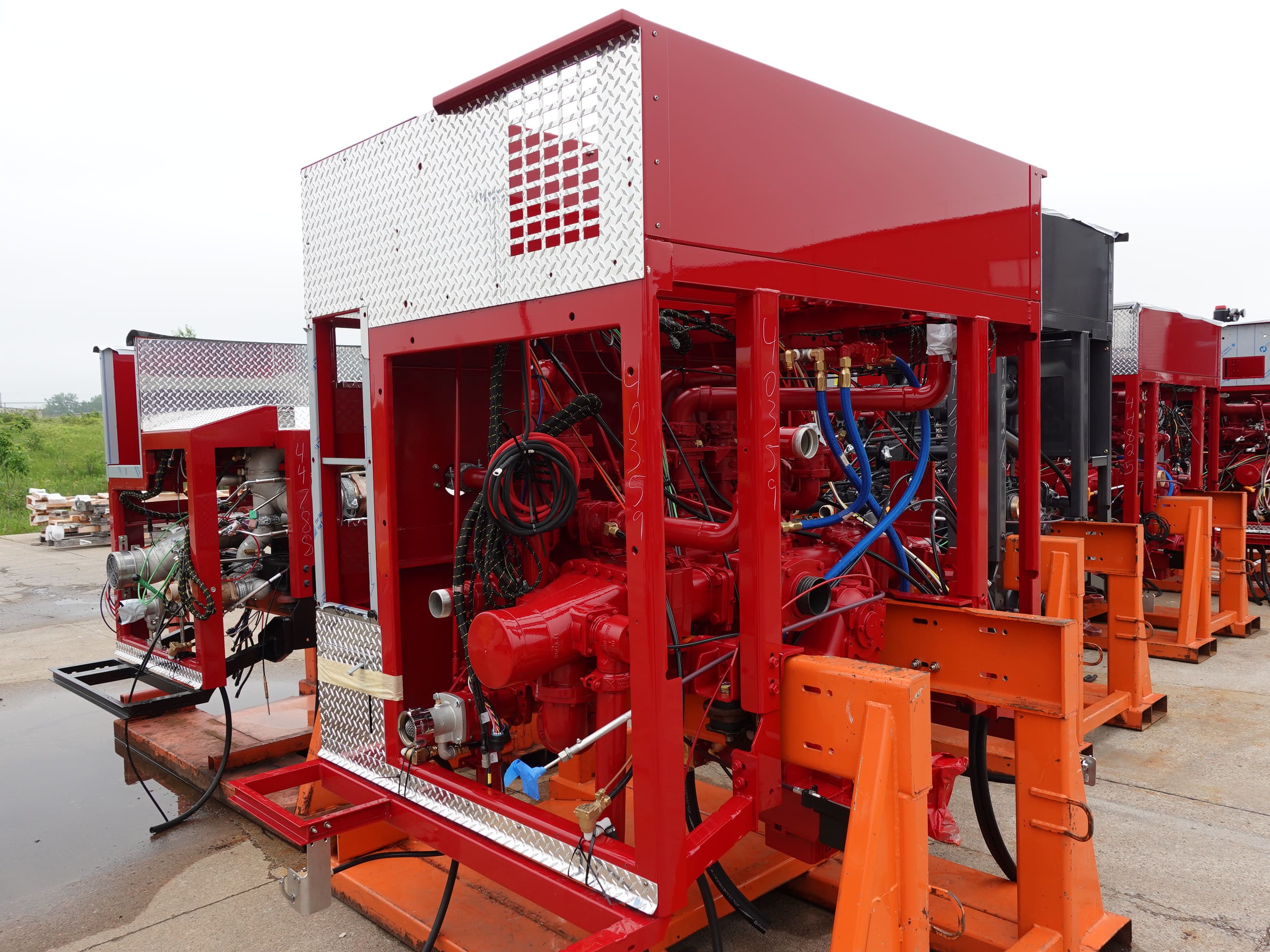

assembly, the frame build began, the pump house was
painted then continued initial assembly, and the body

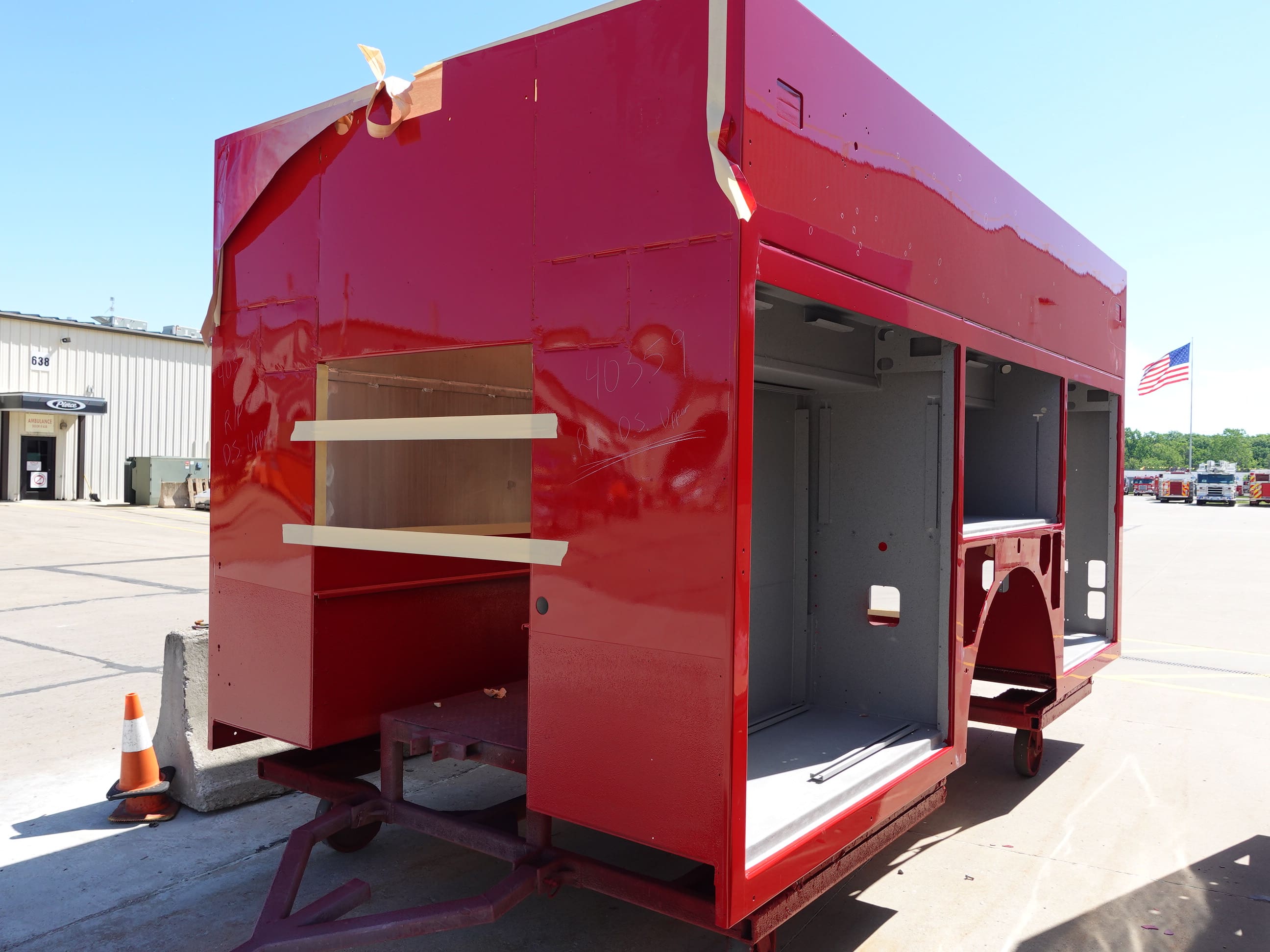

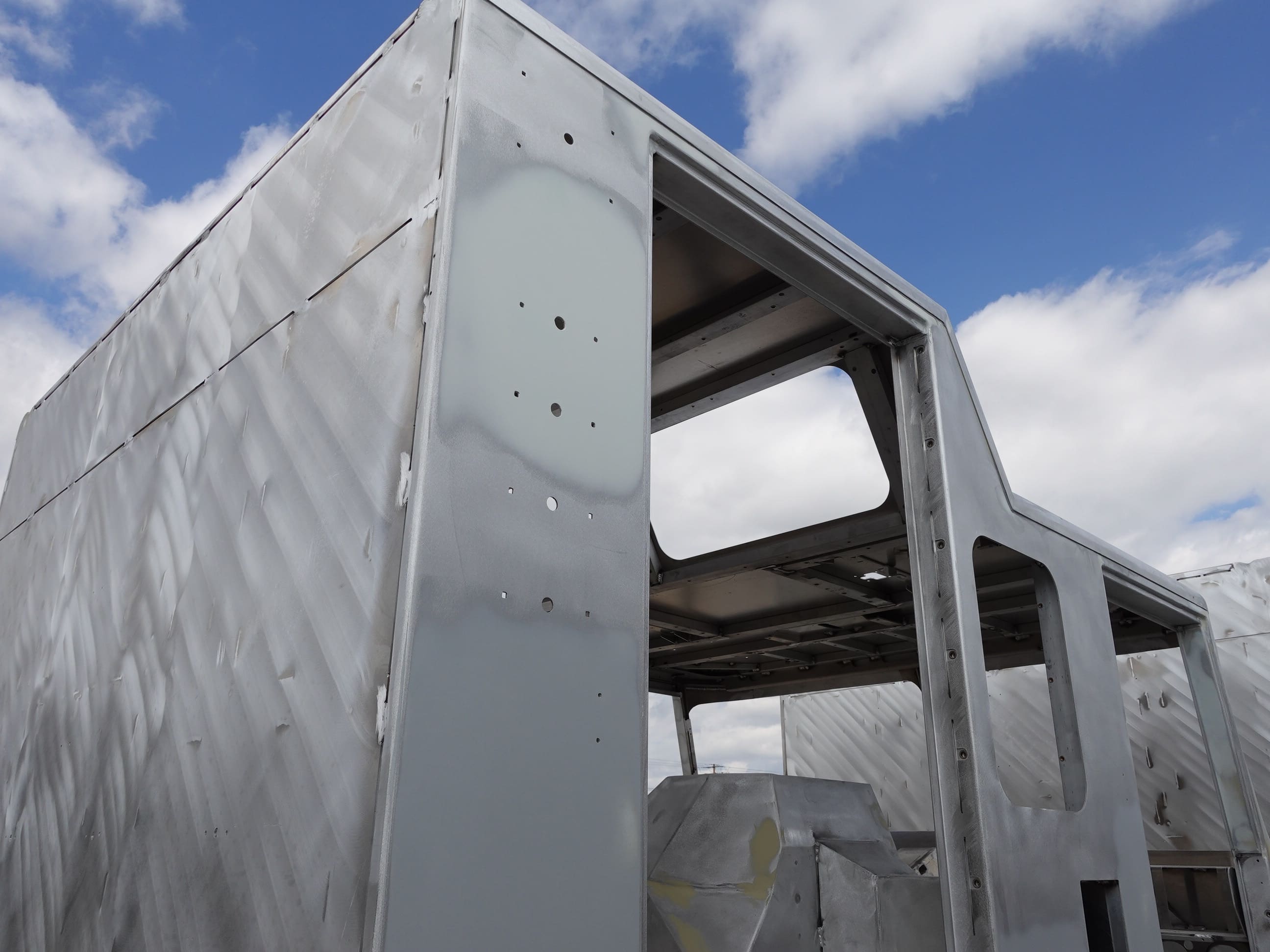

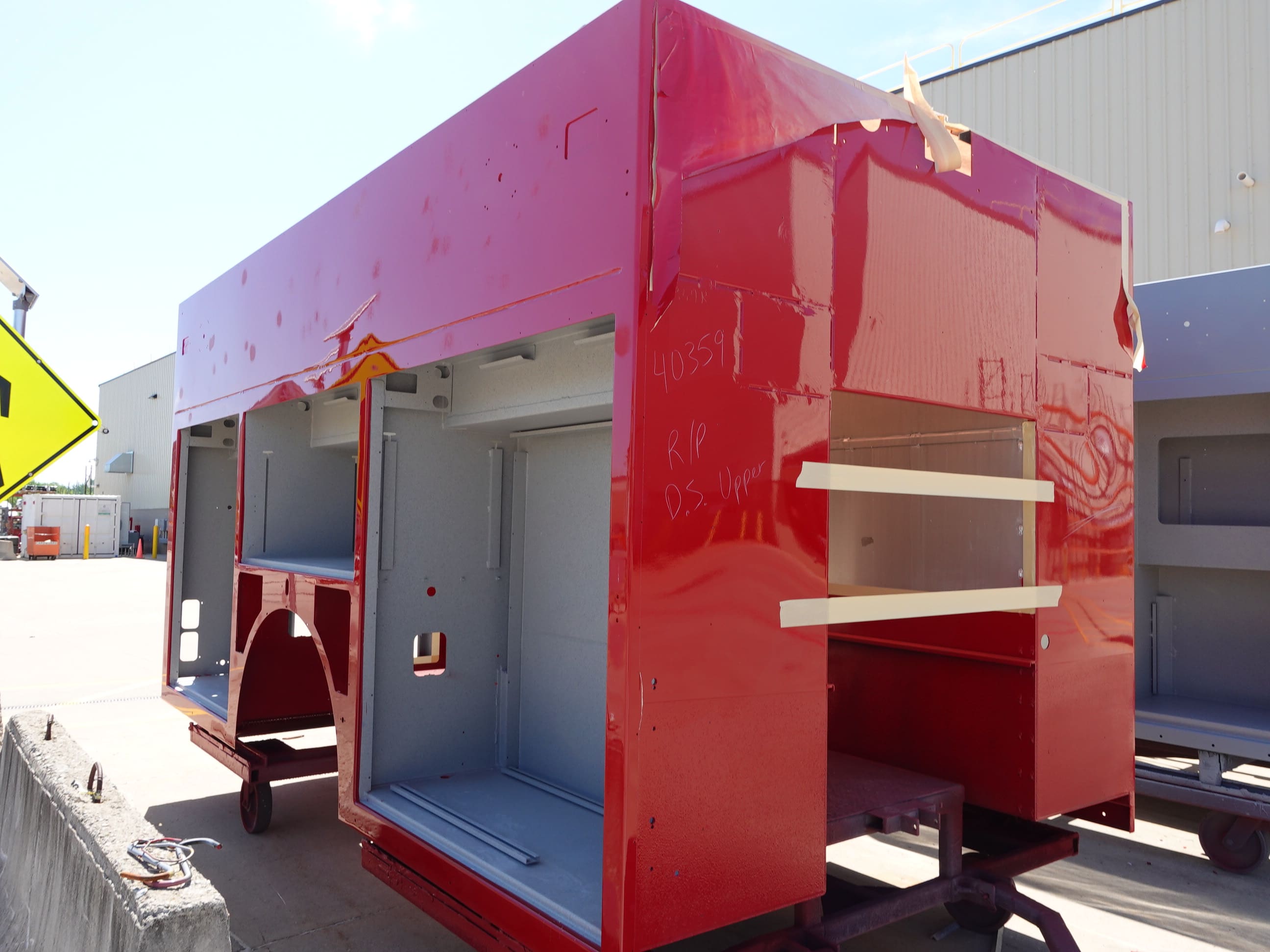

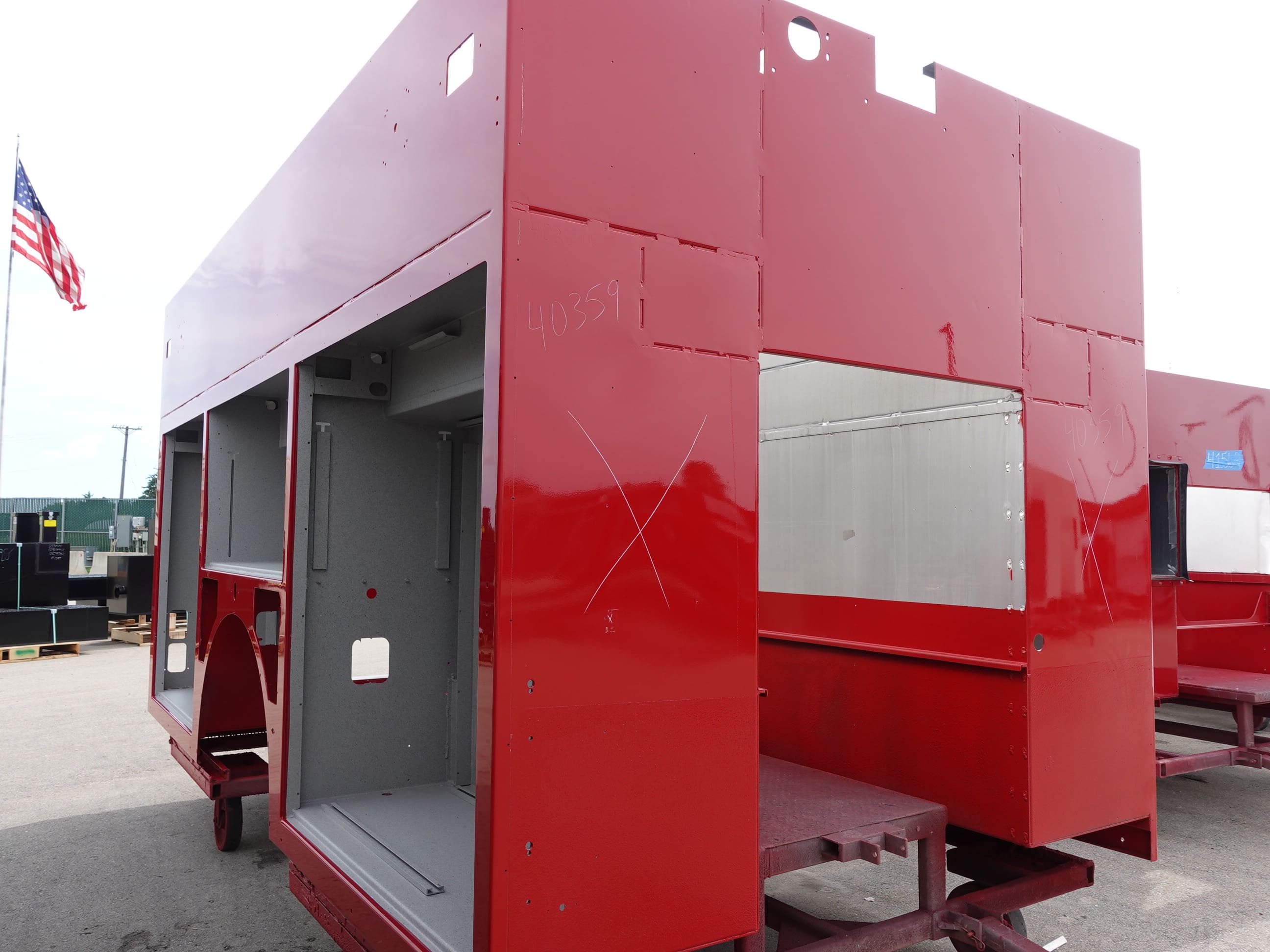

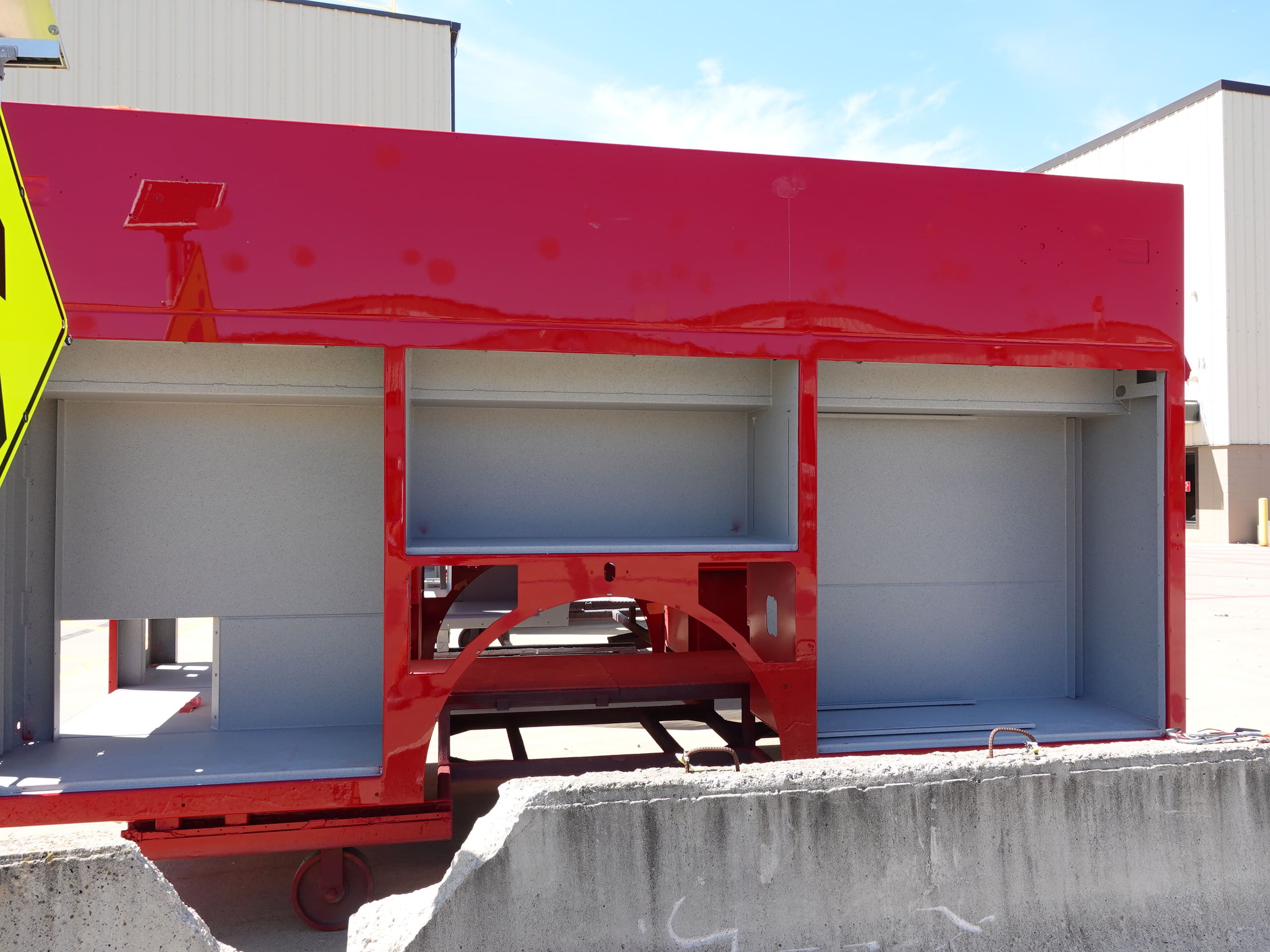

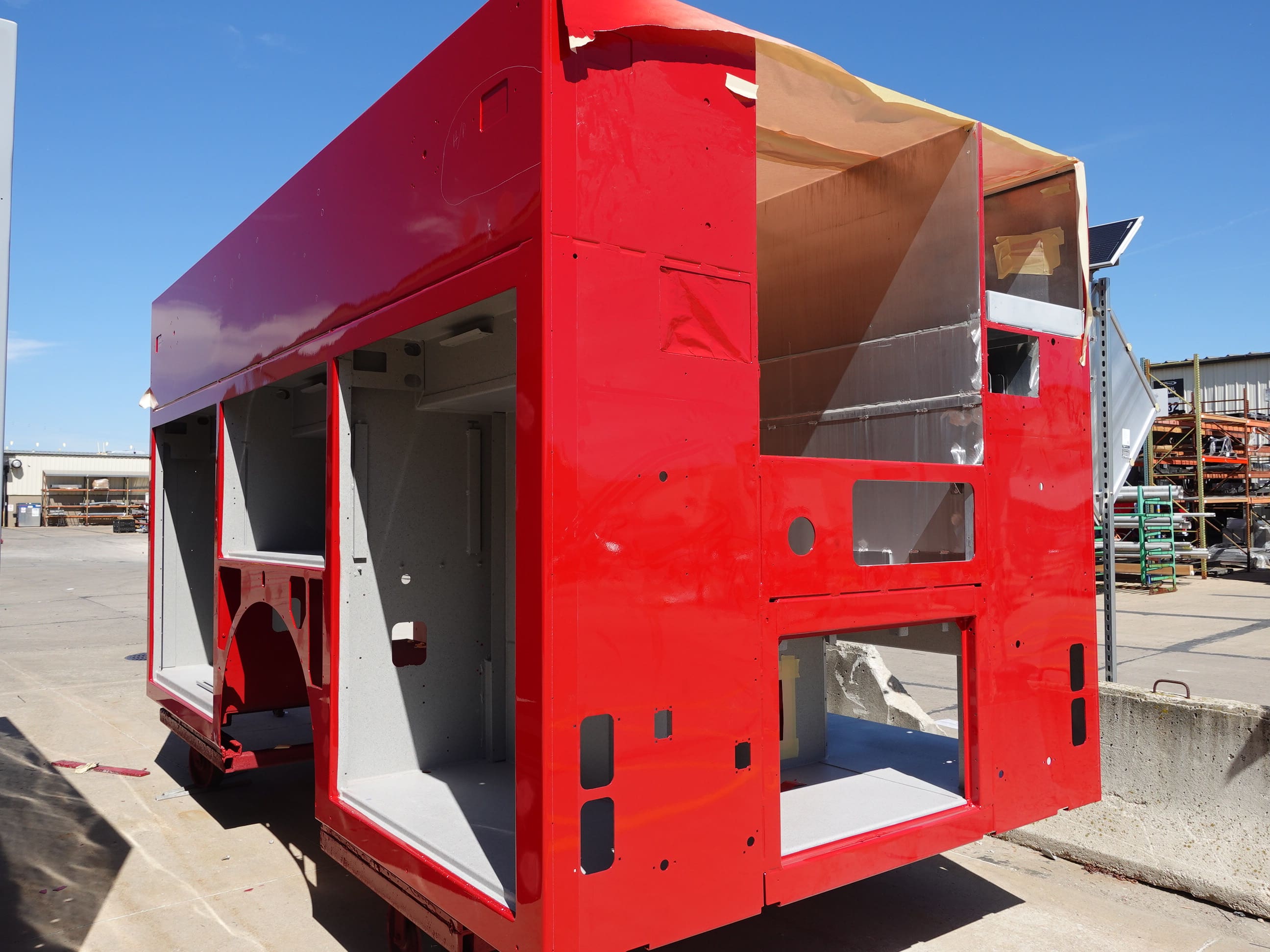

completed the paint process.
05-22-26
In this report, the cab continued the paint process, the pump house began initial assembly, and the body was unavailable for photos.
05-15-26
In this report, the cab continued through paint, the pump house structure continued fabrication, and the body was fabricated and staged.
