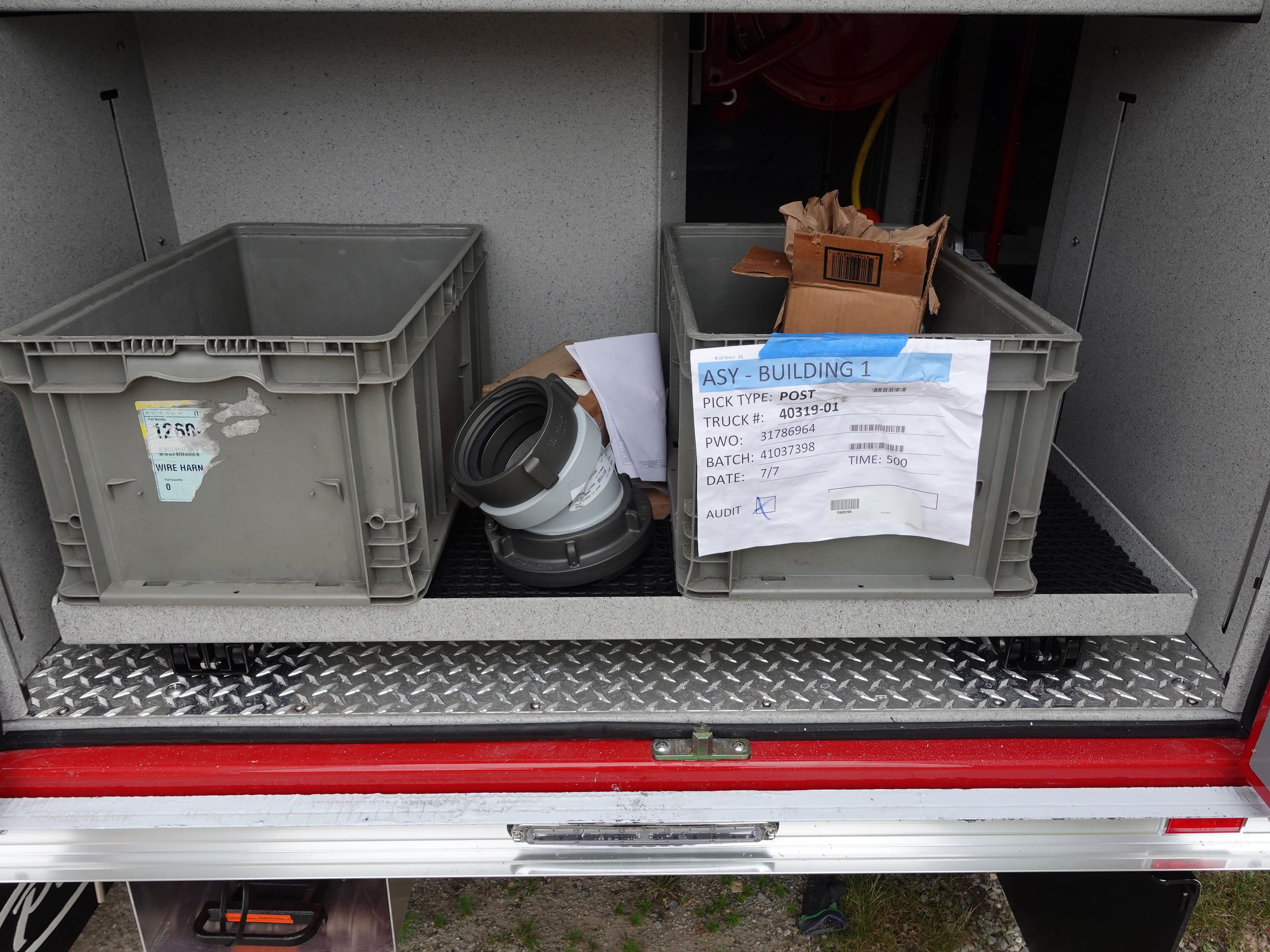

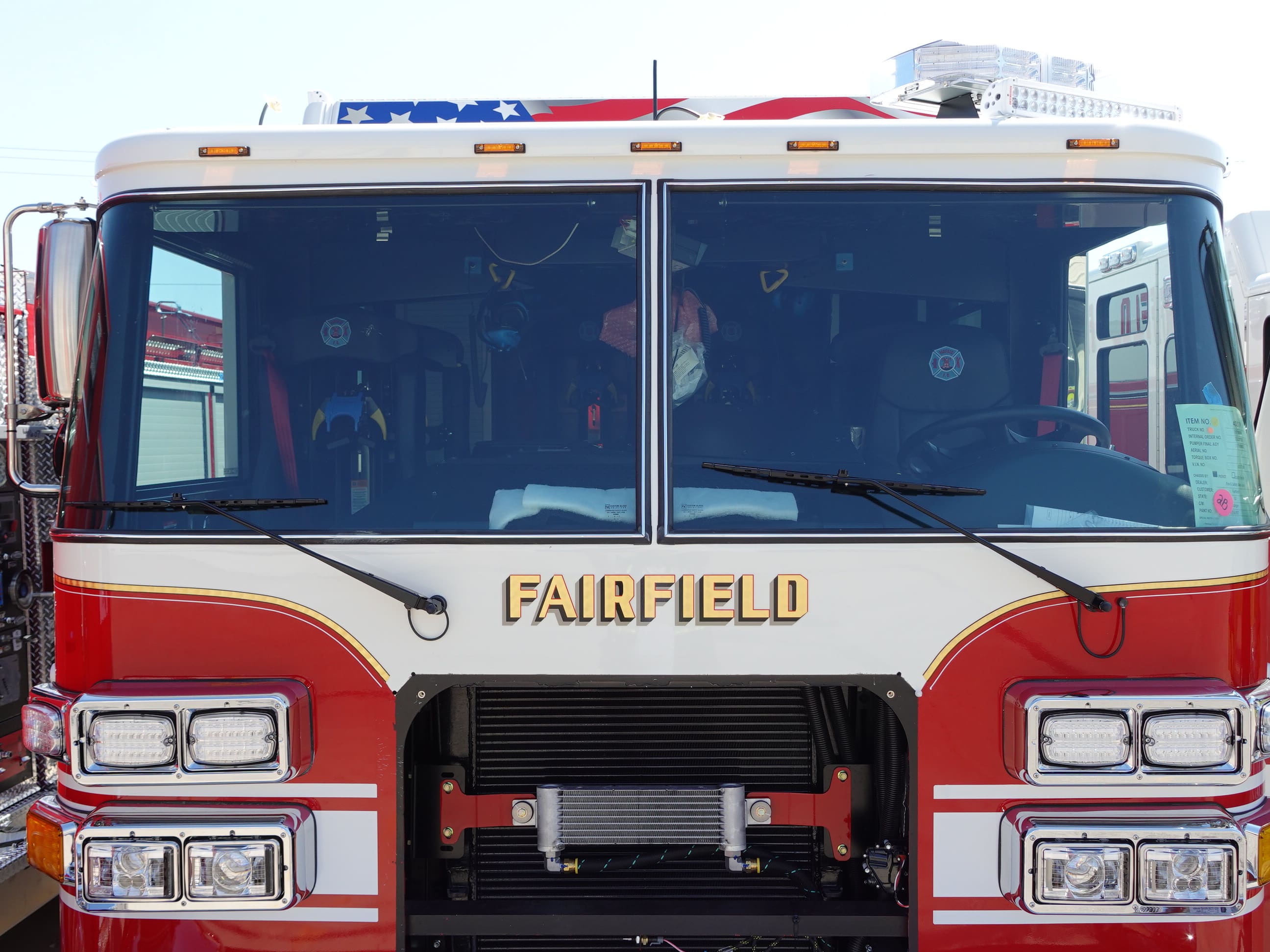

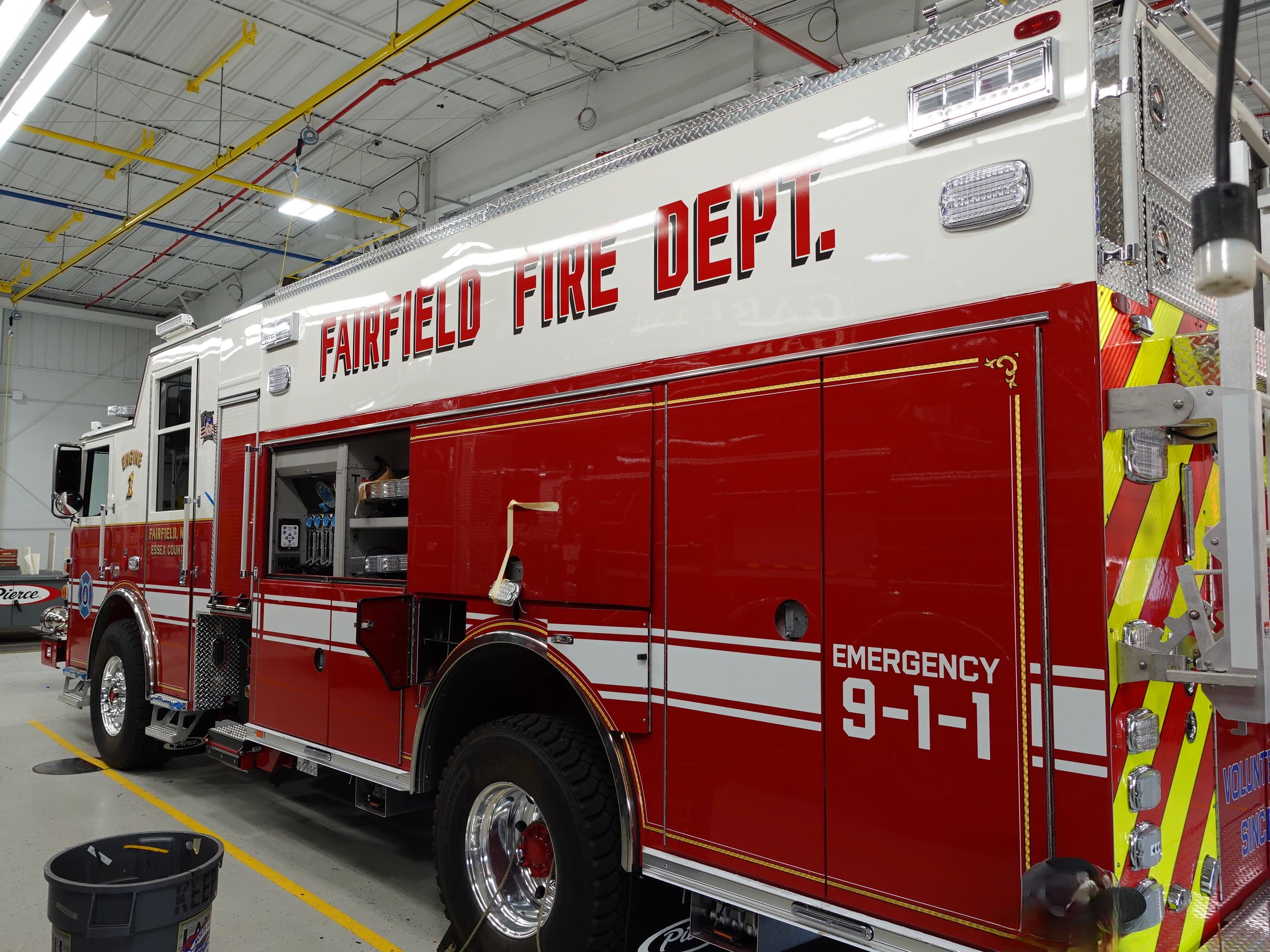

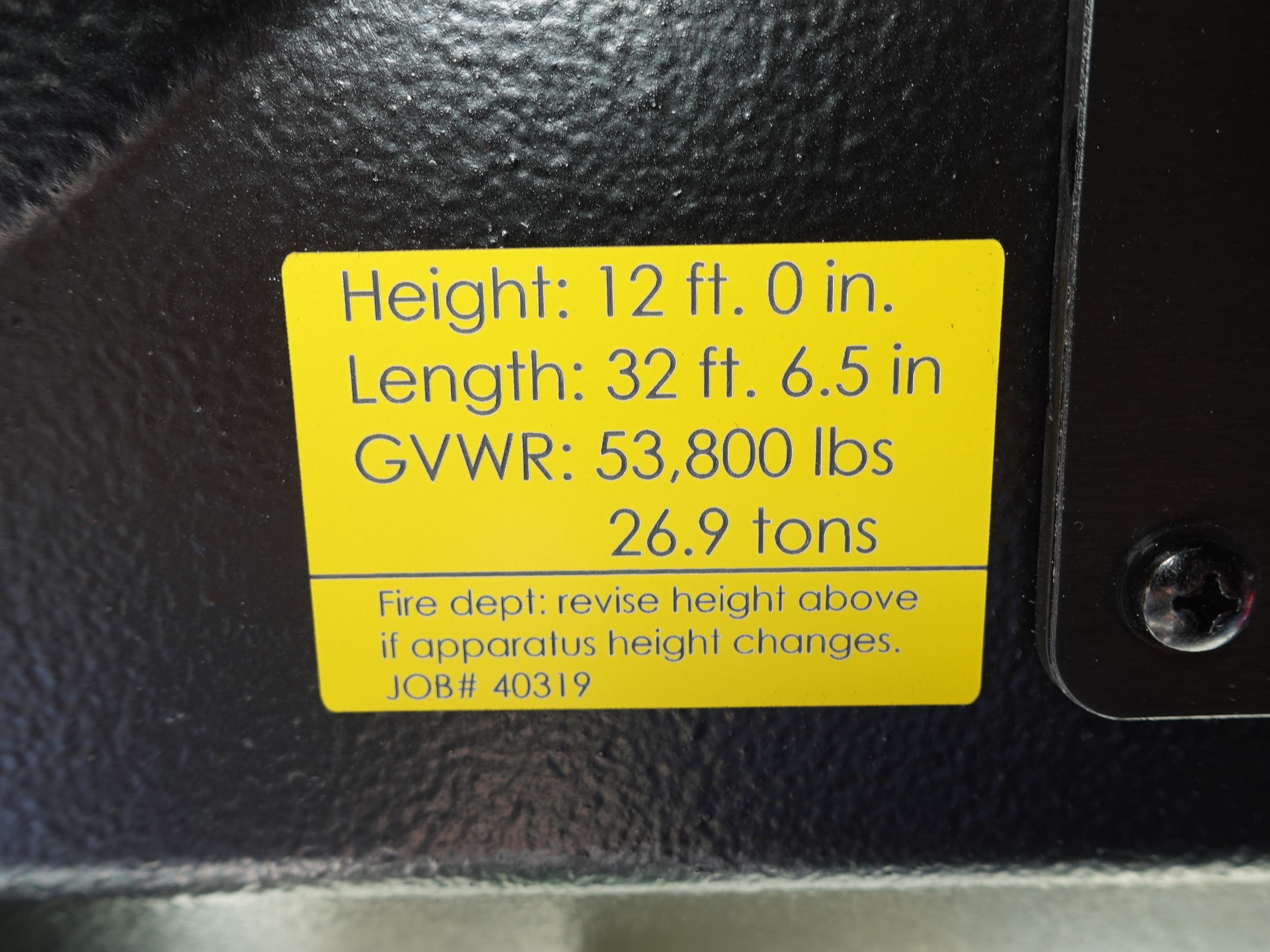

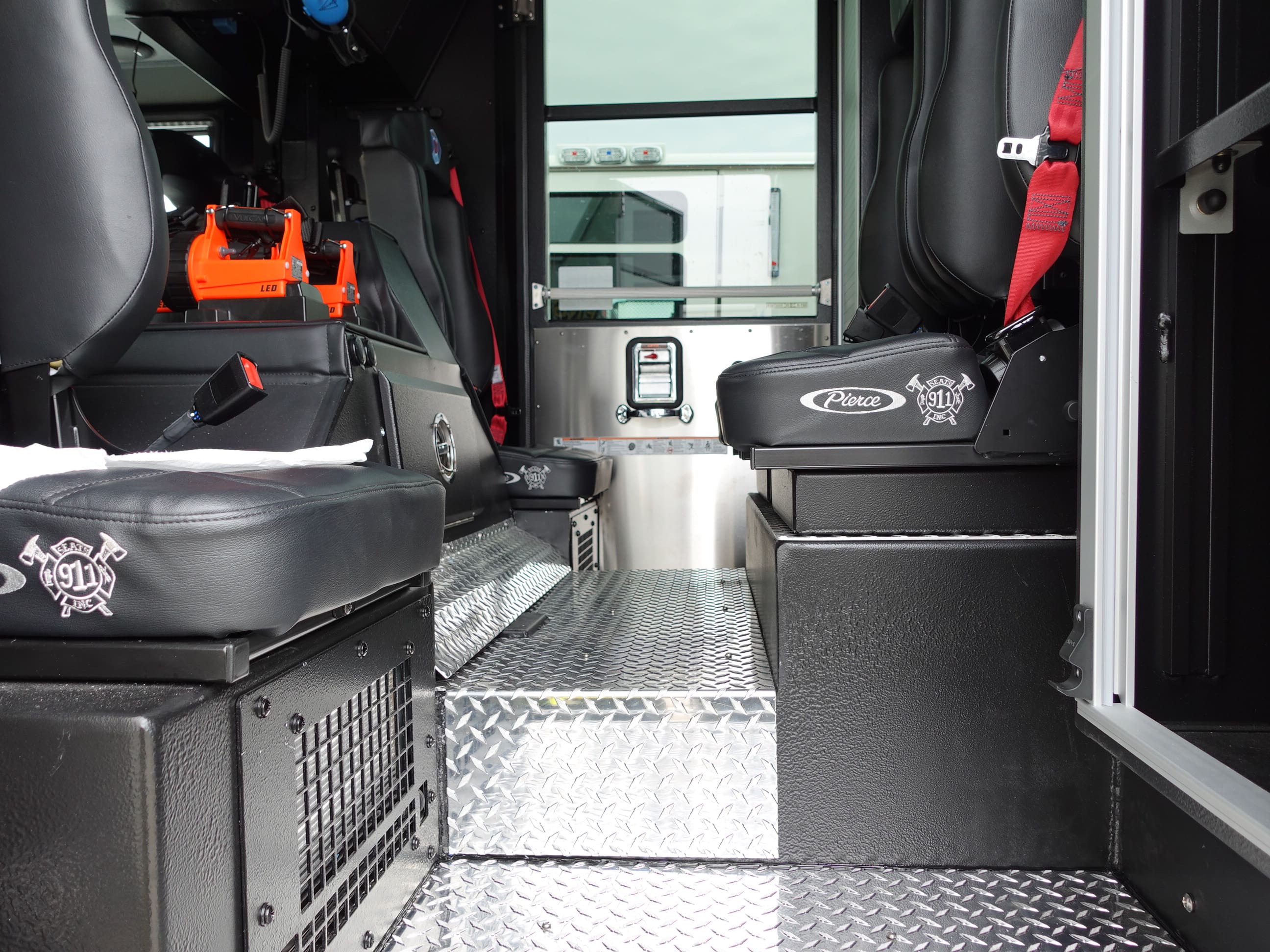

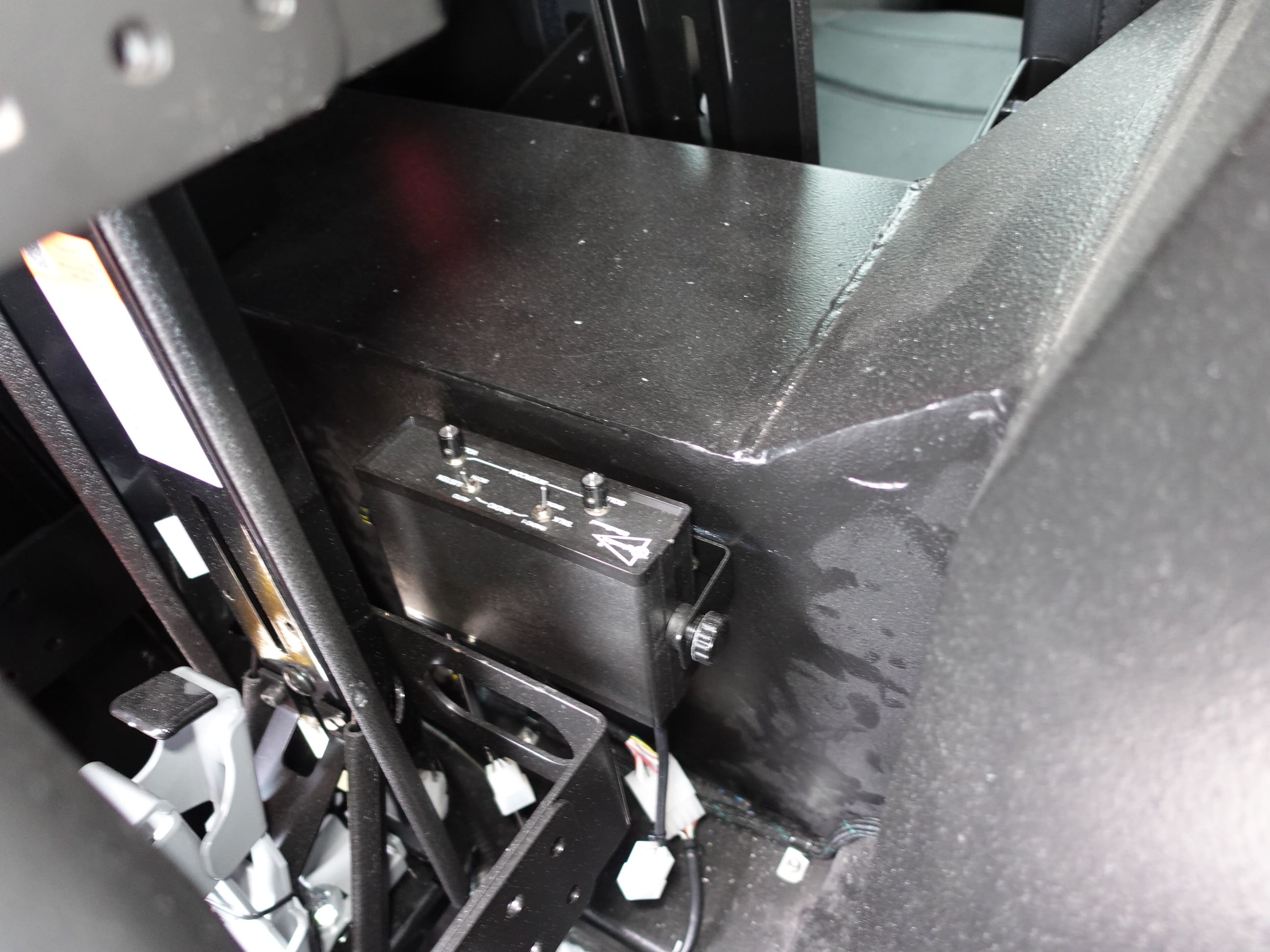

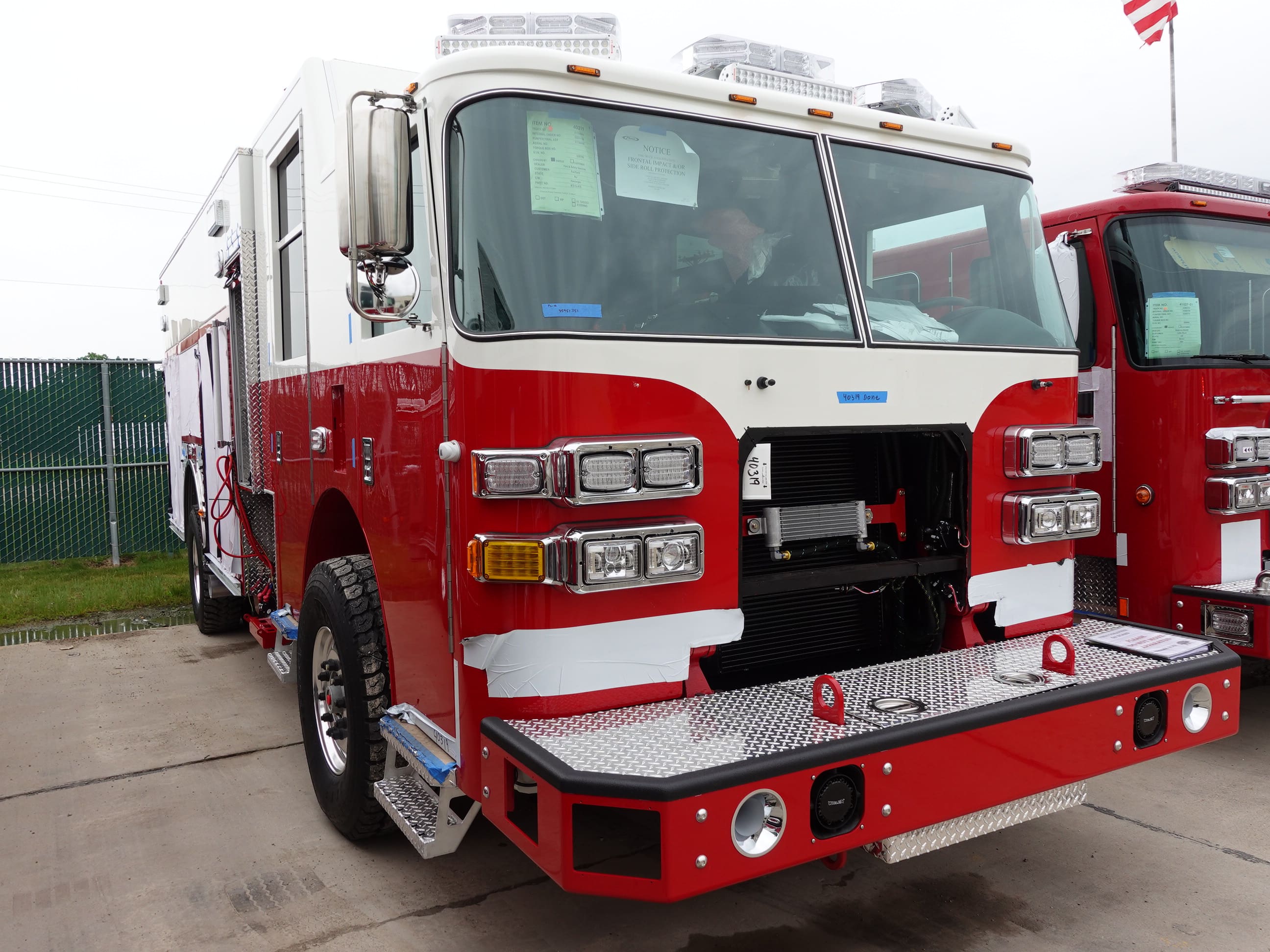

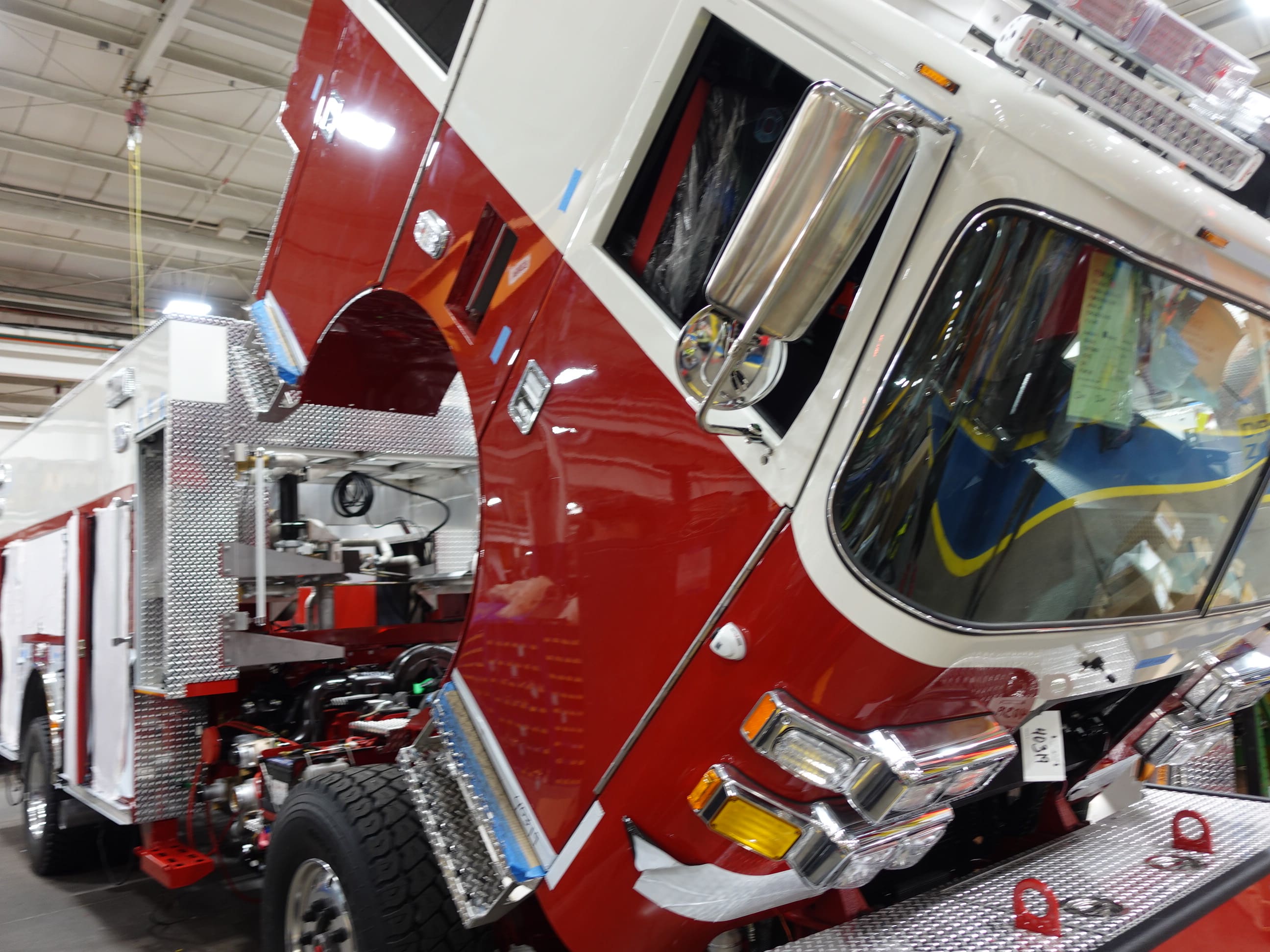

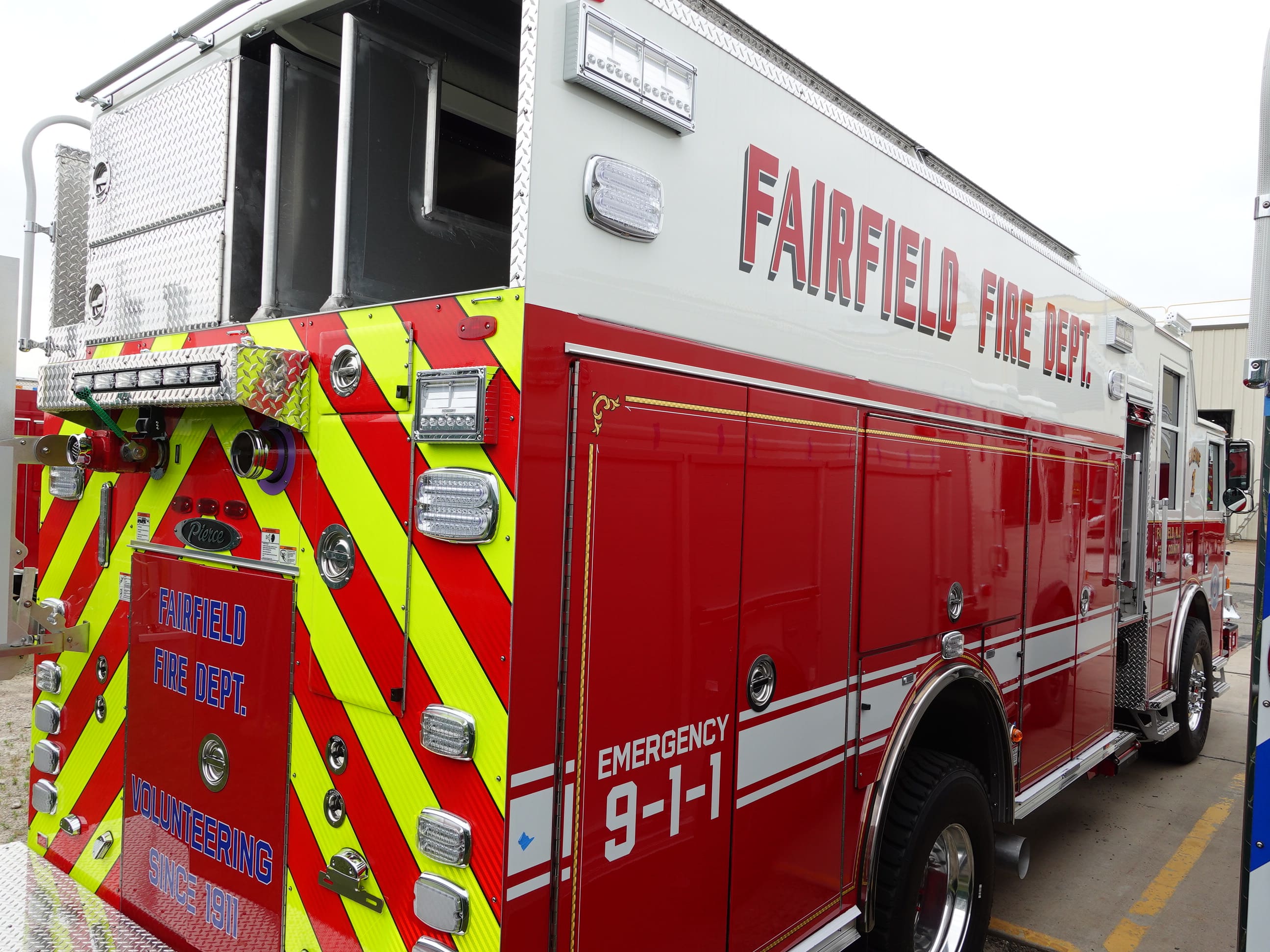

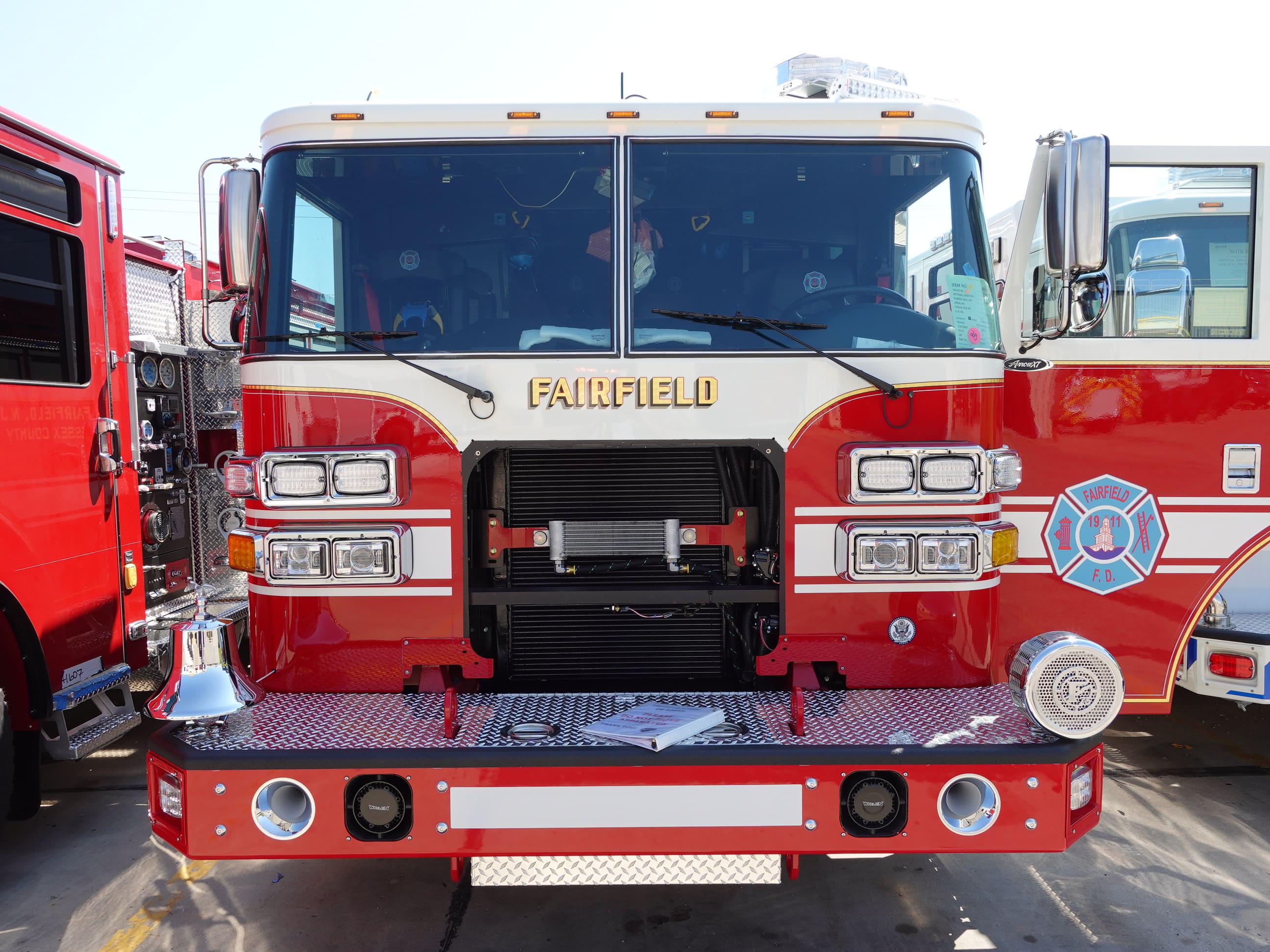

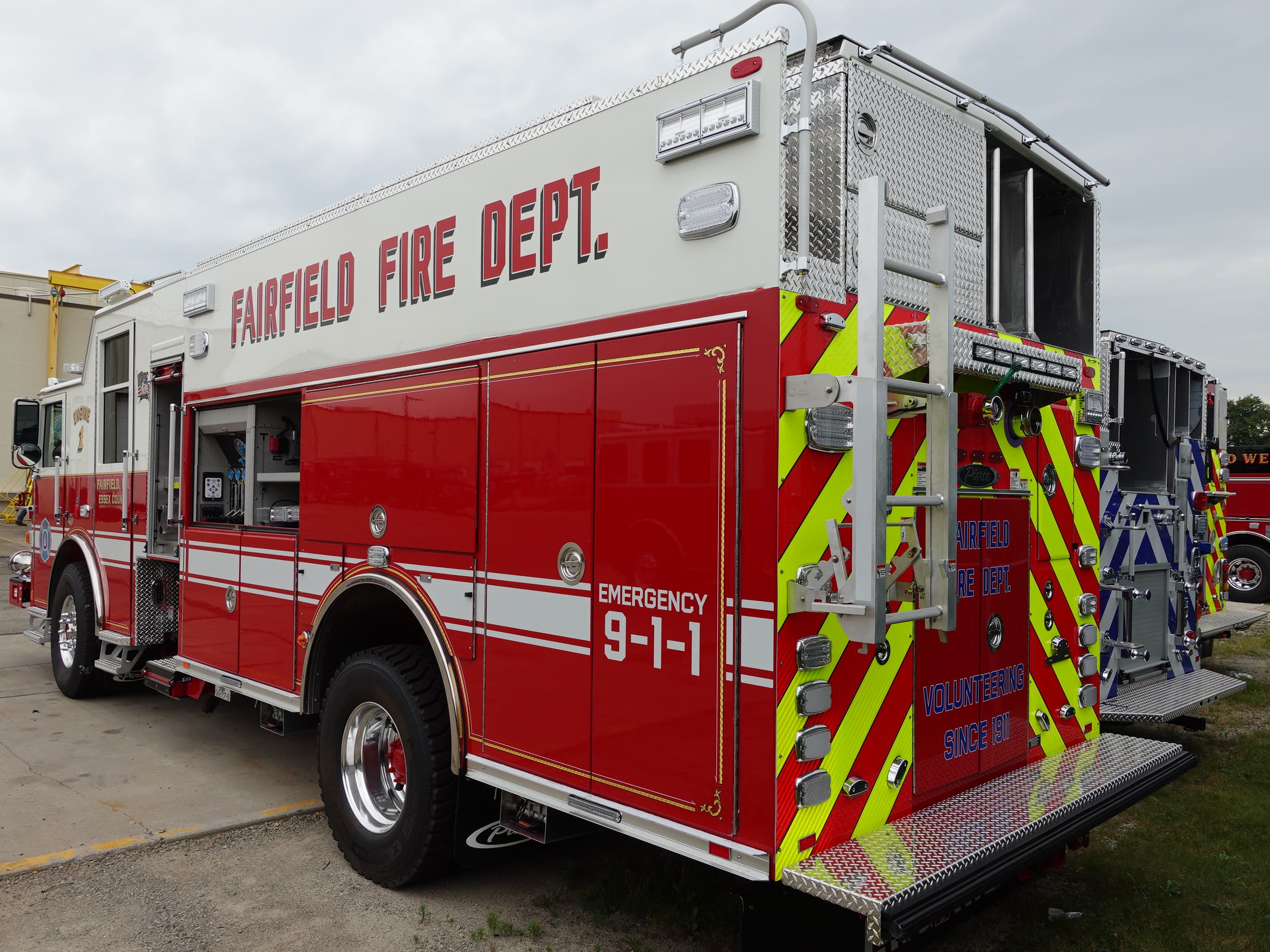

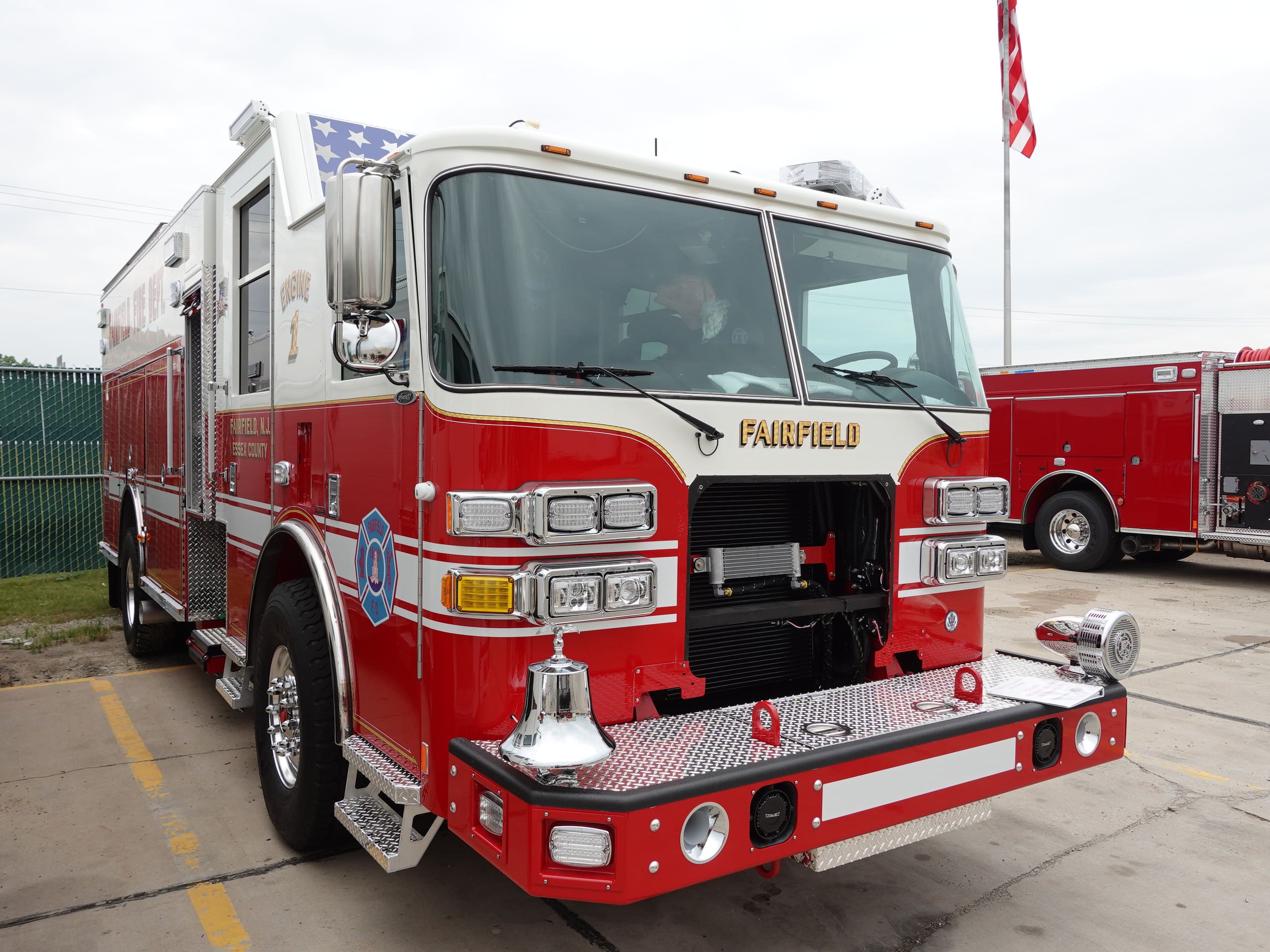

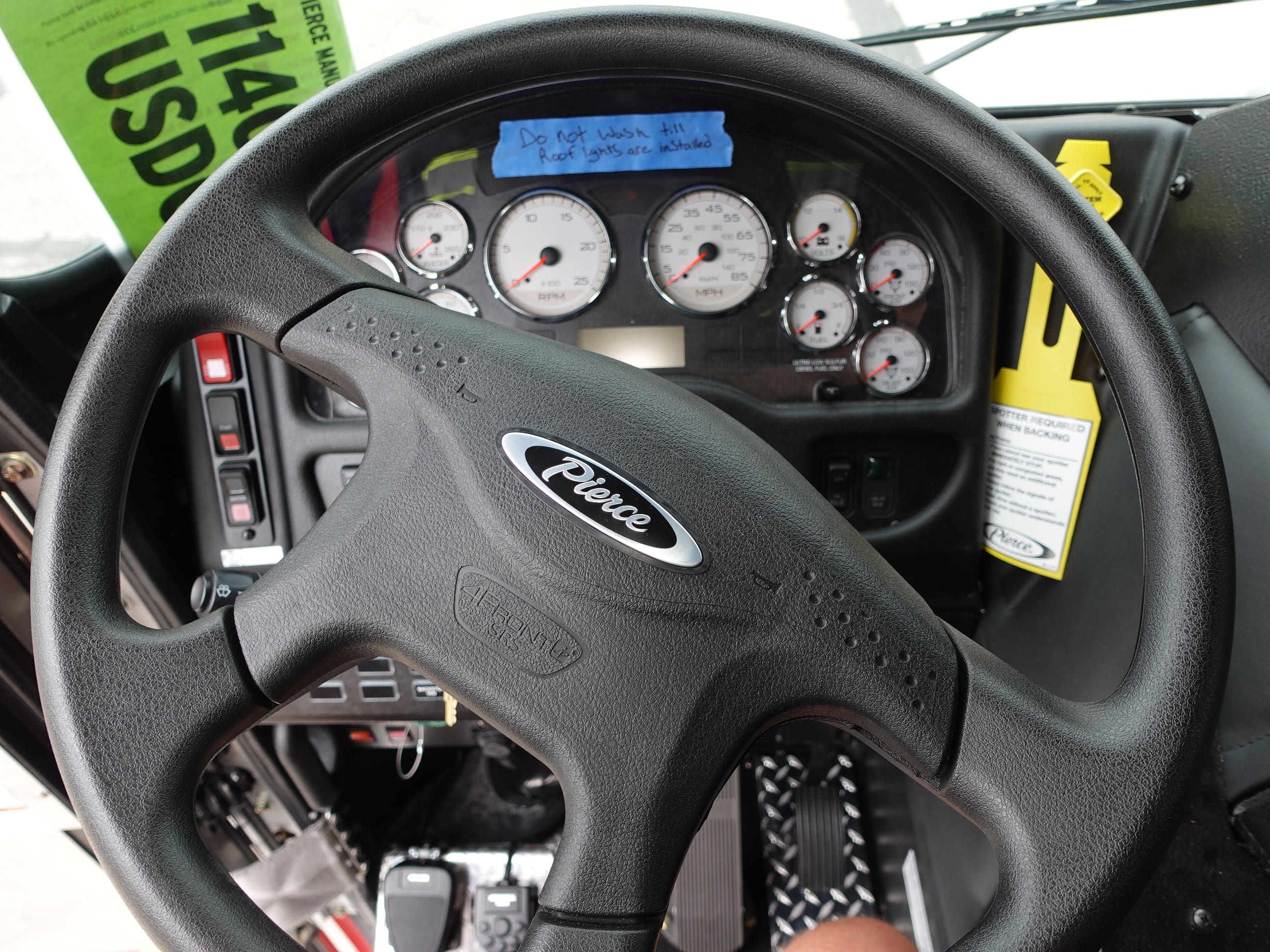

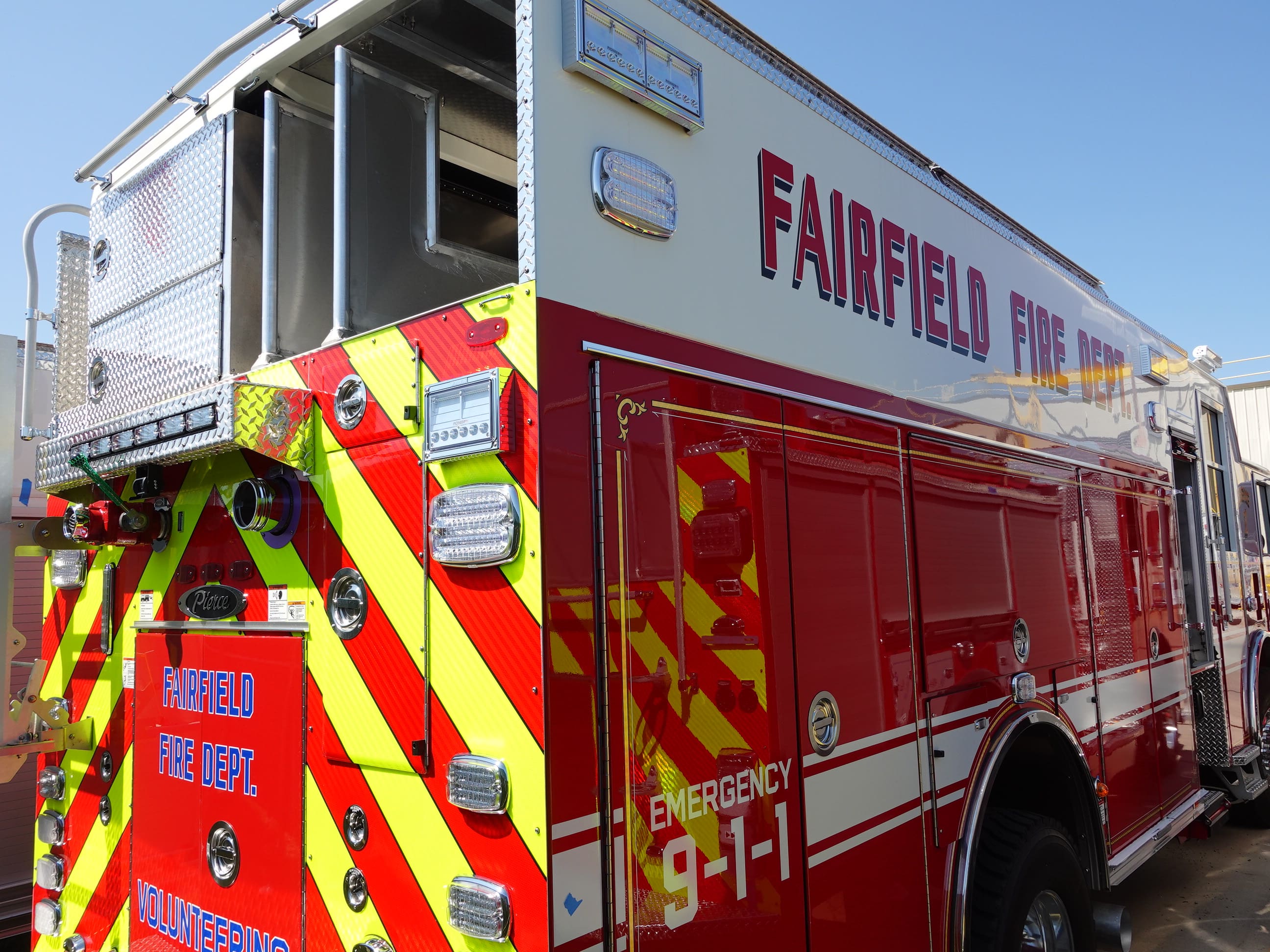

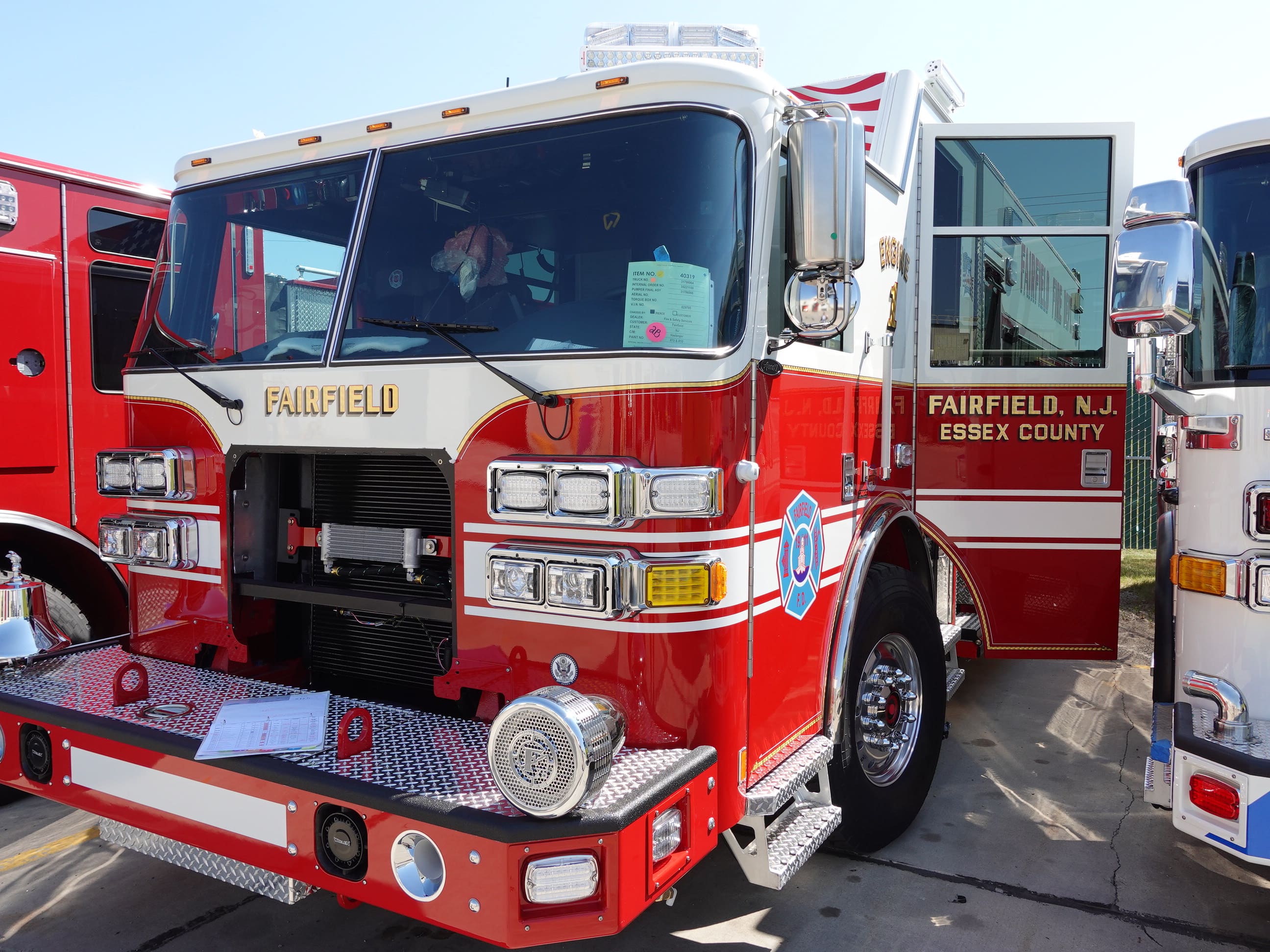

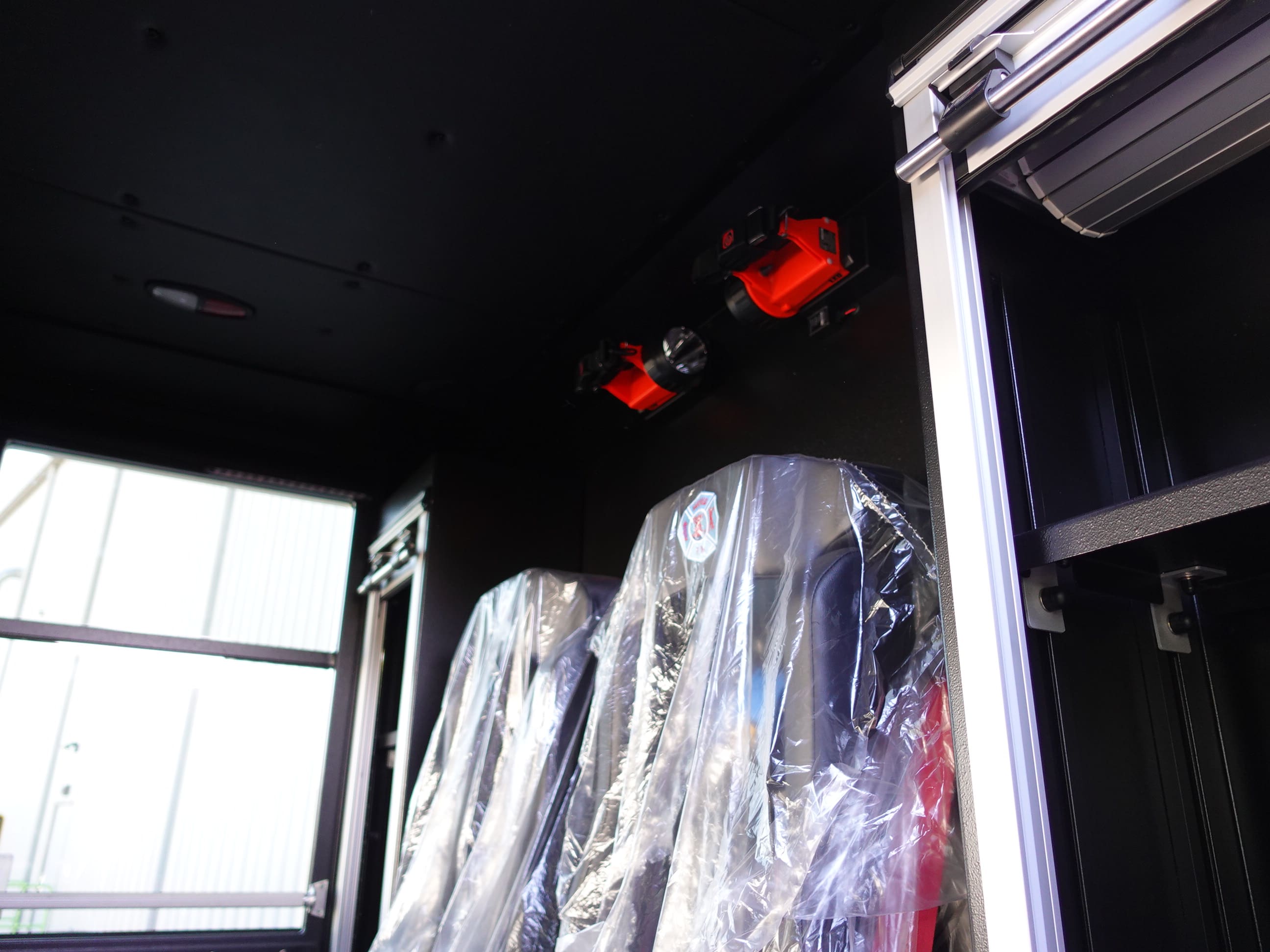

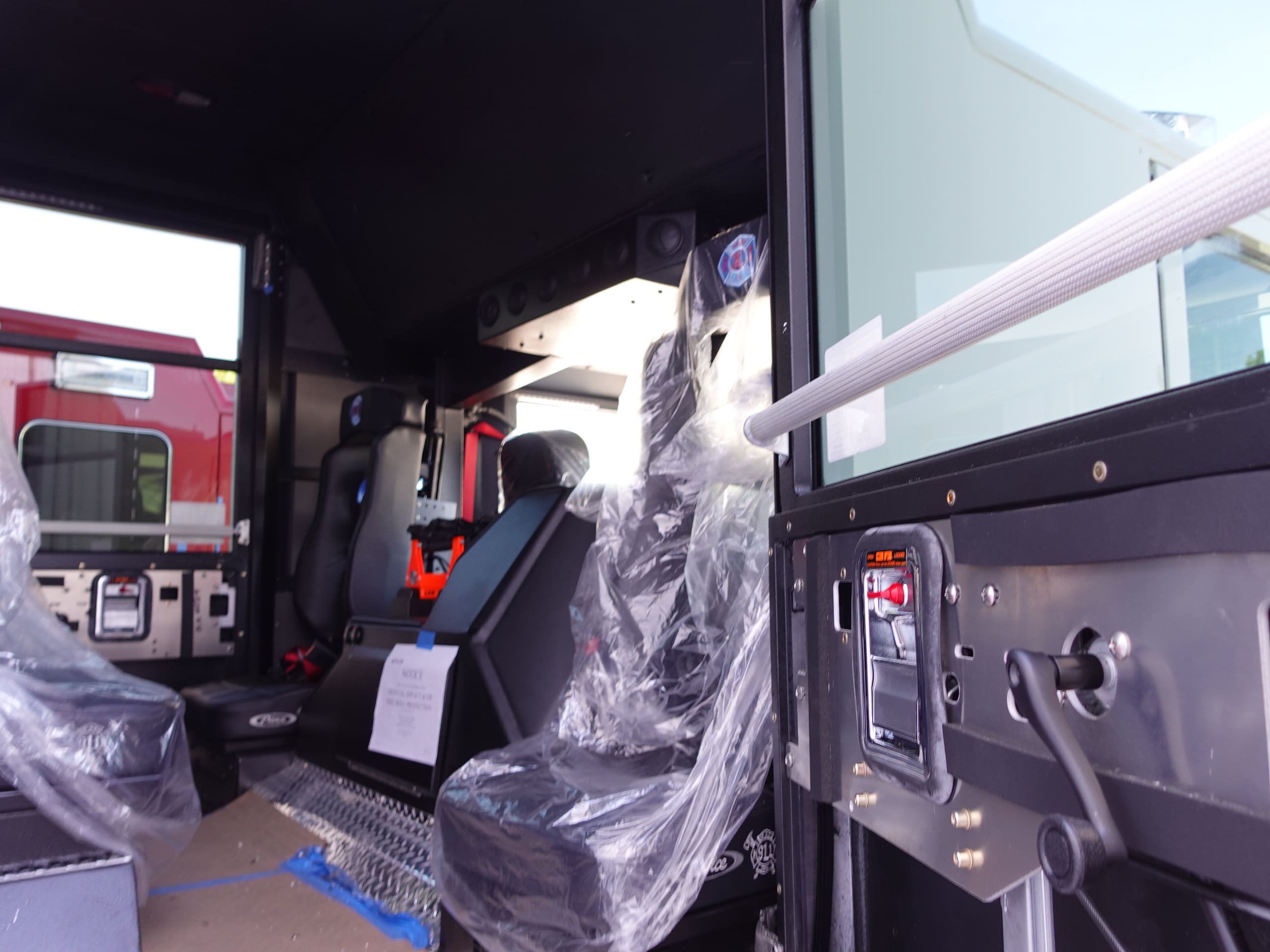

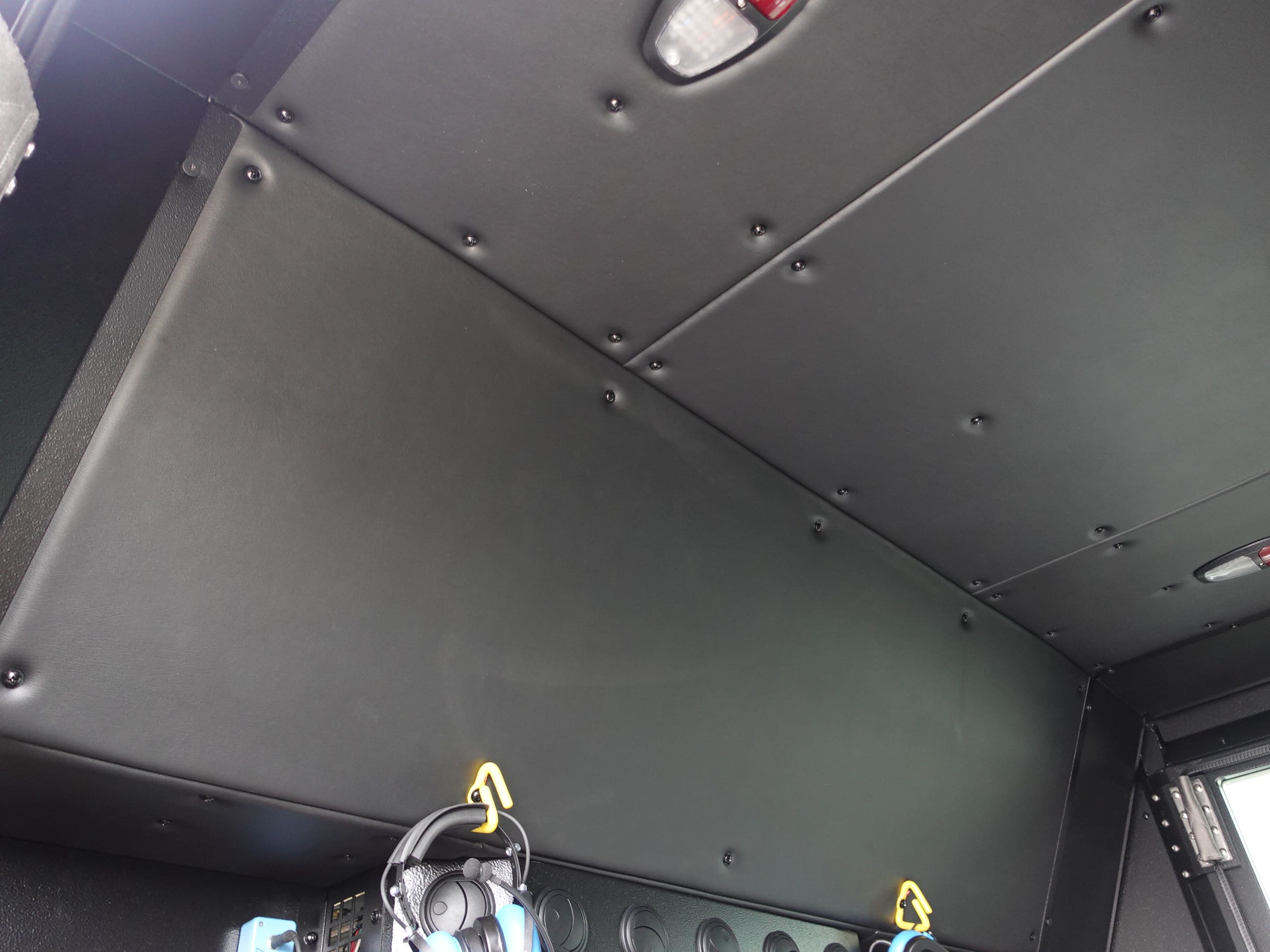

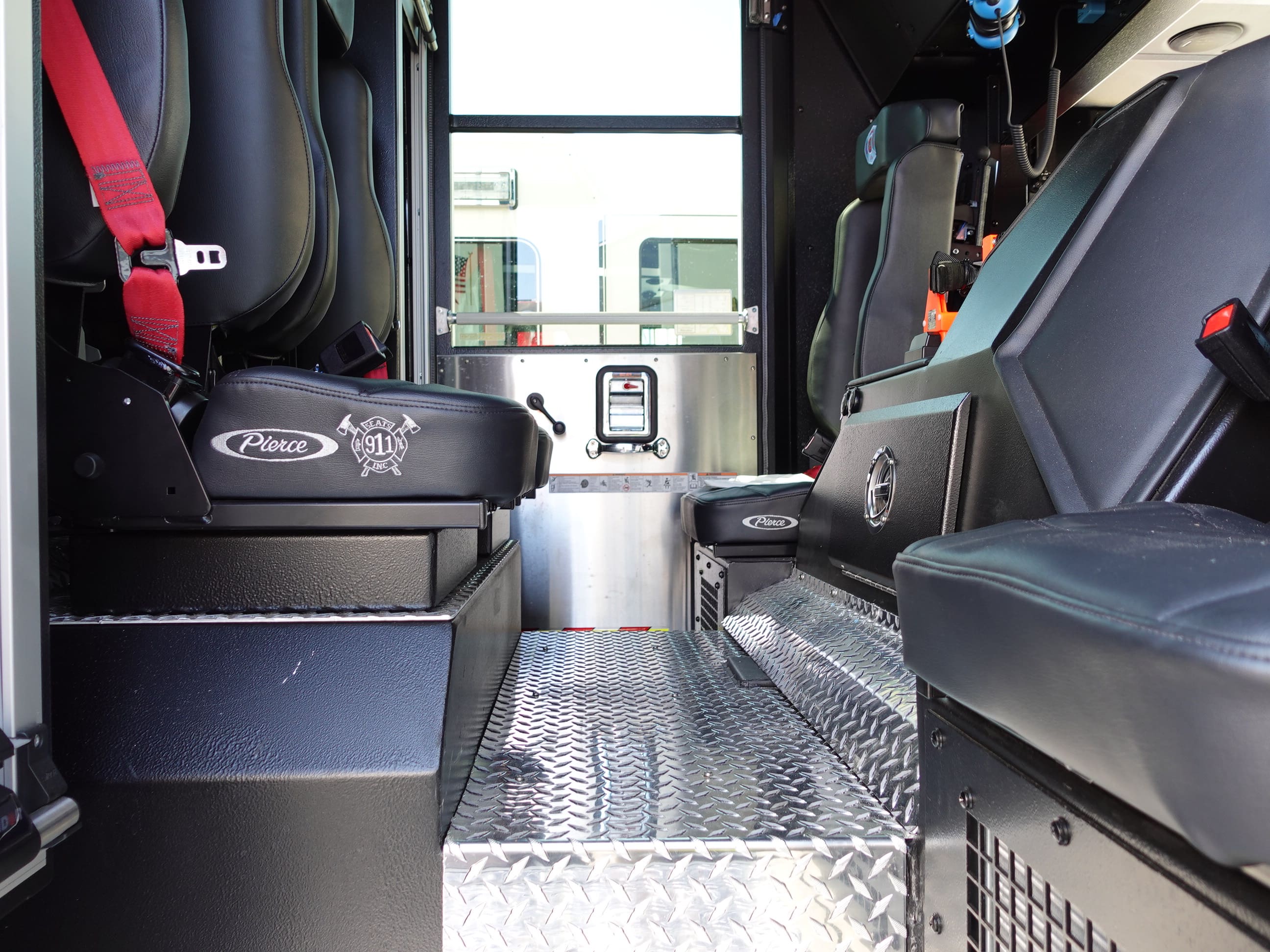

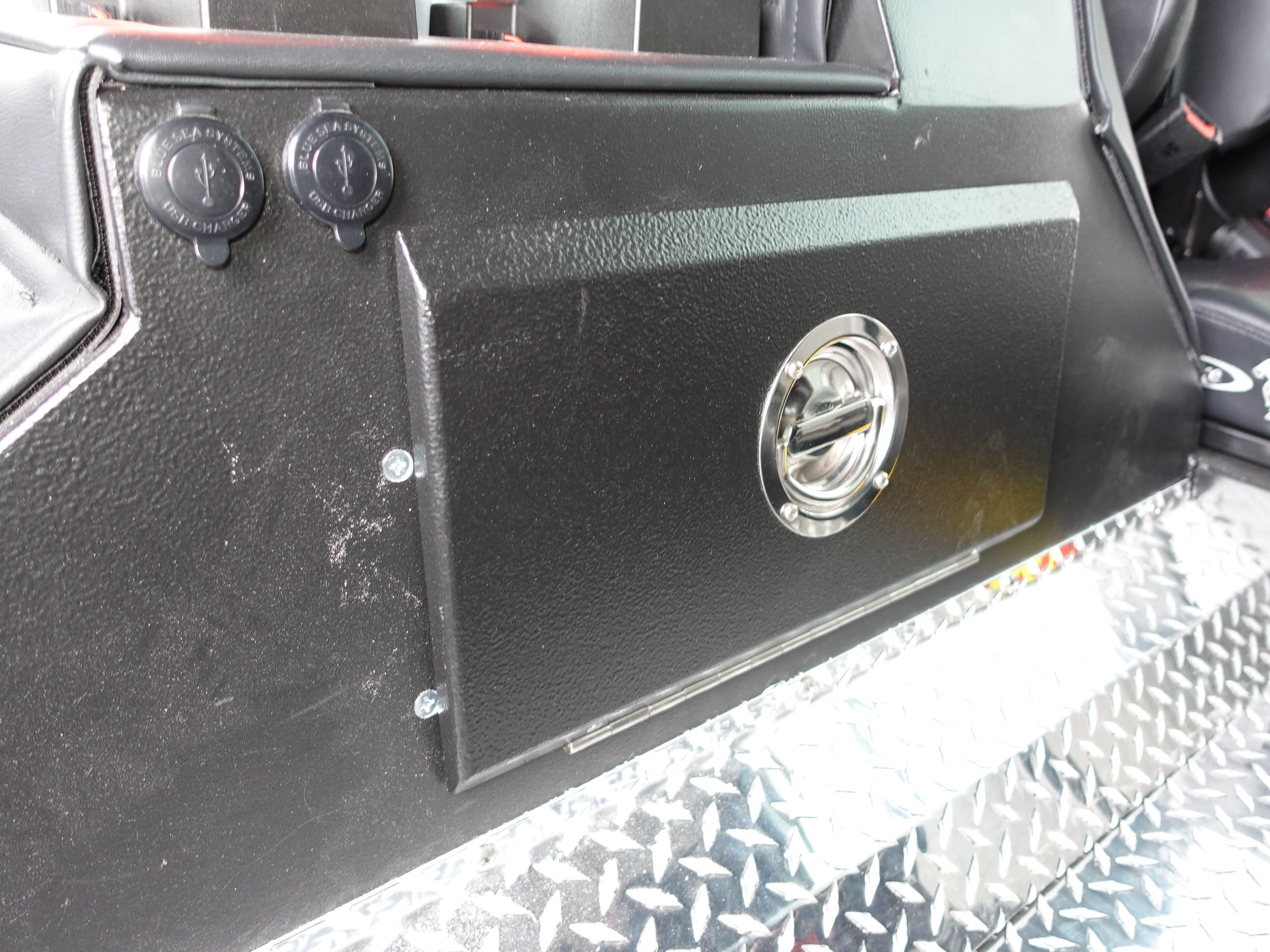

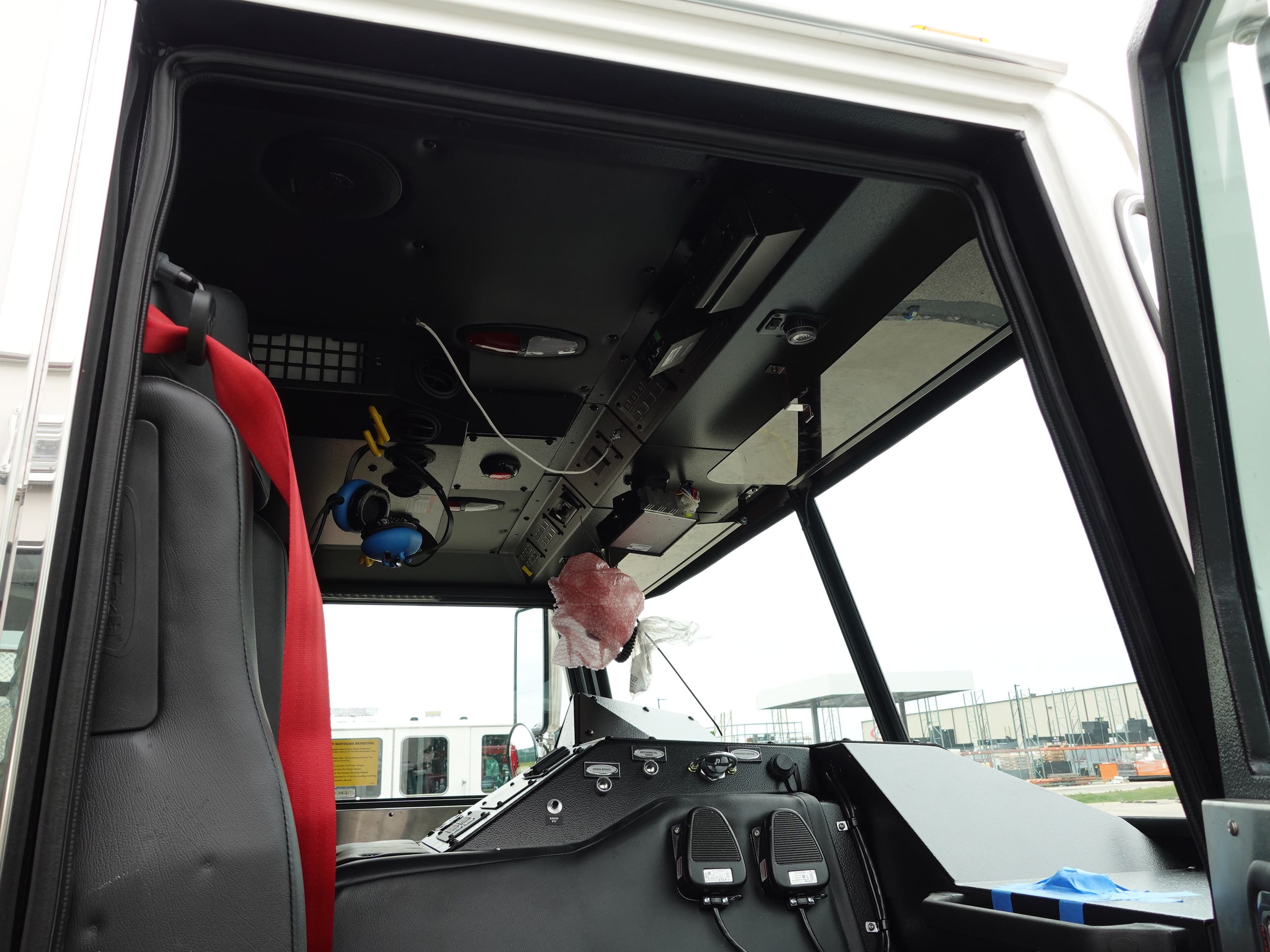

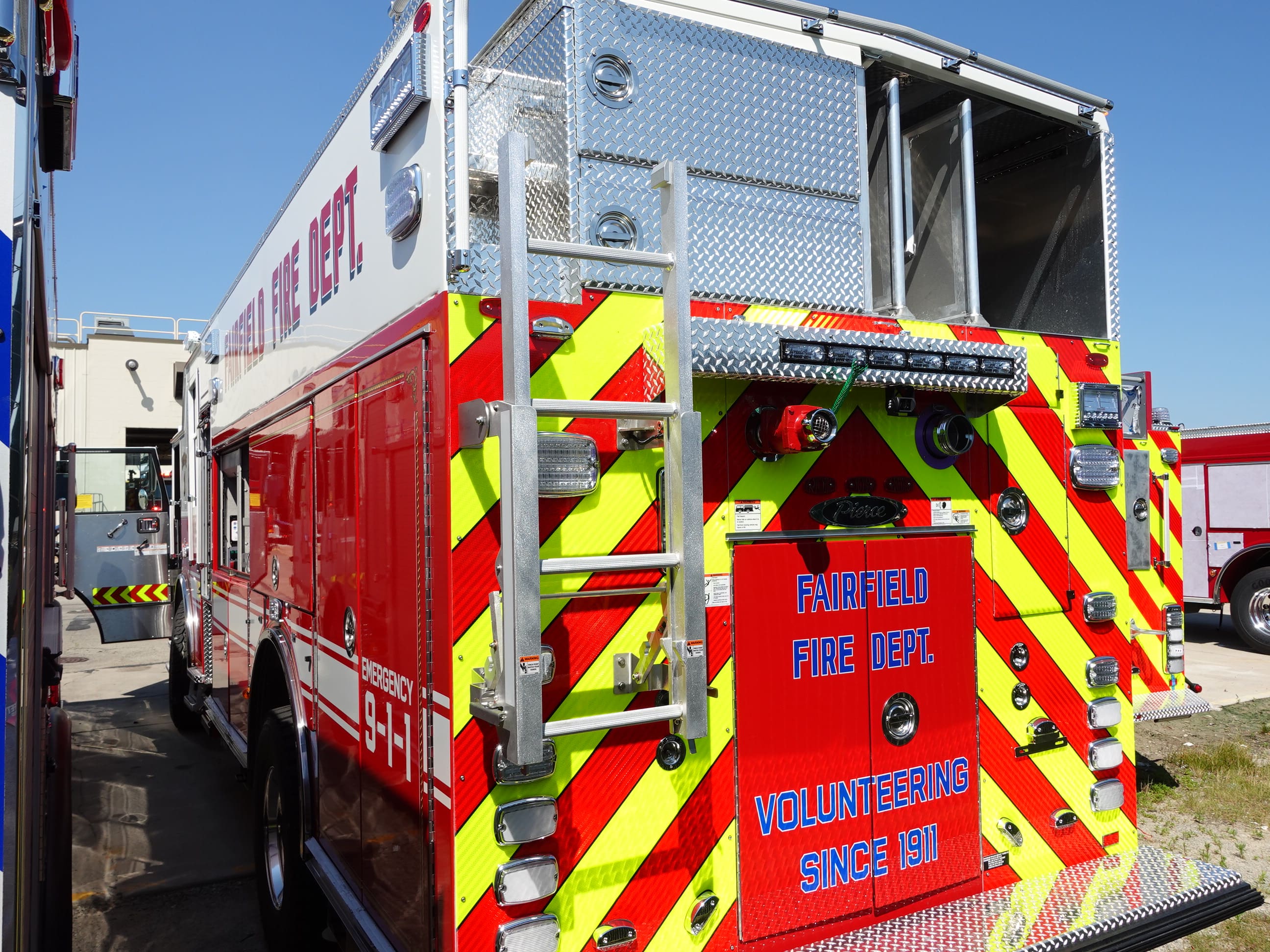

08-07-26

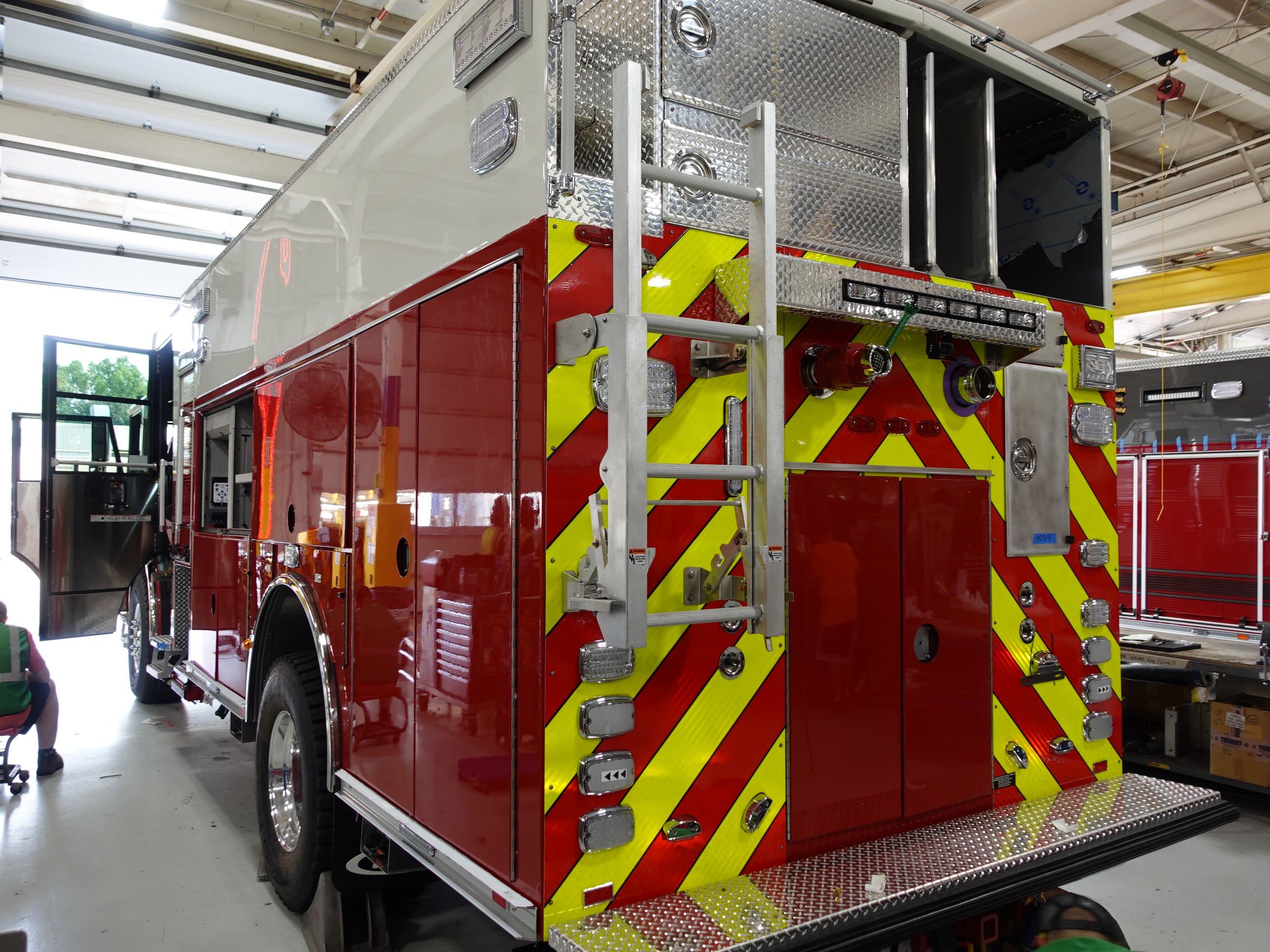

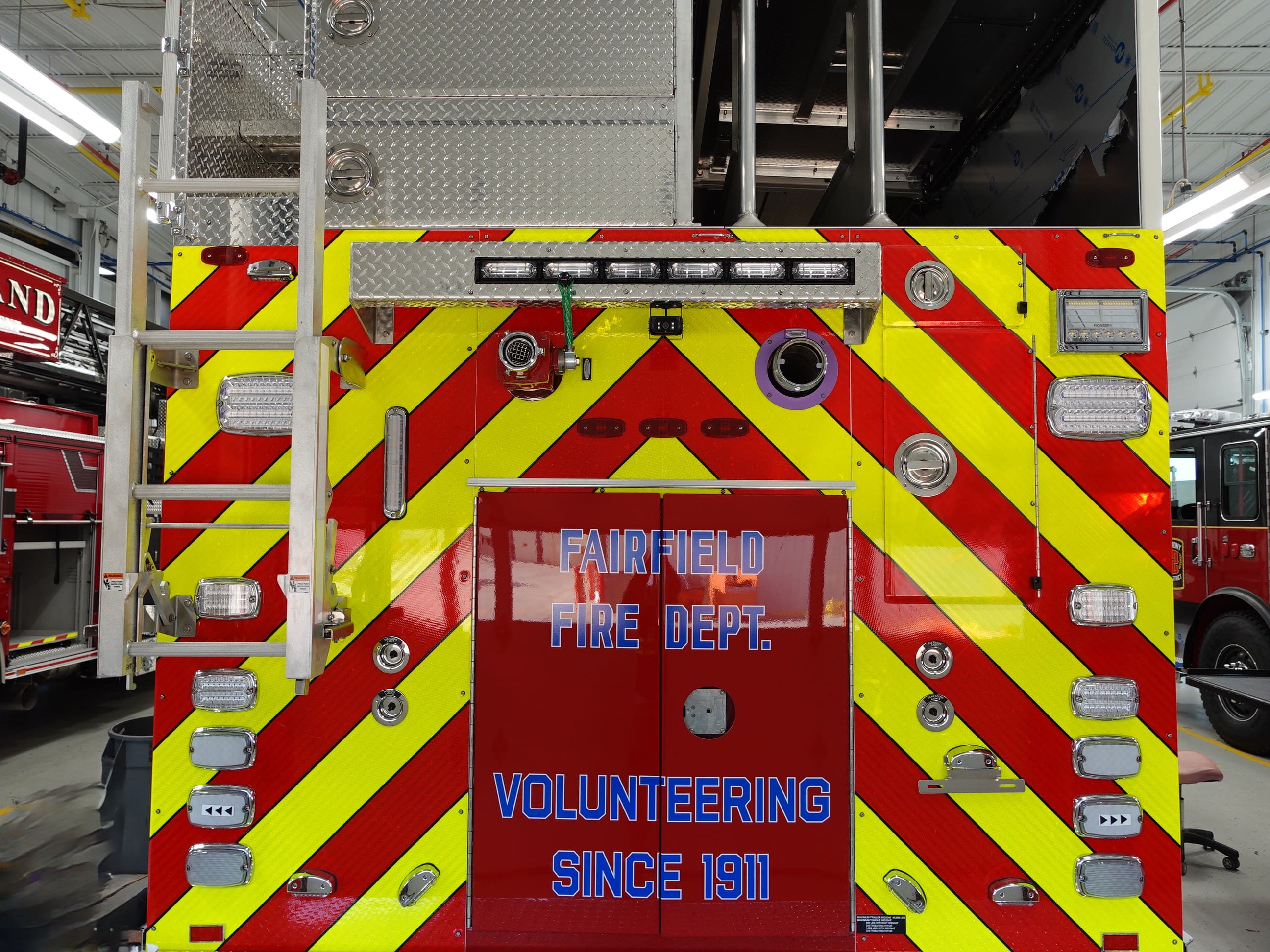

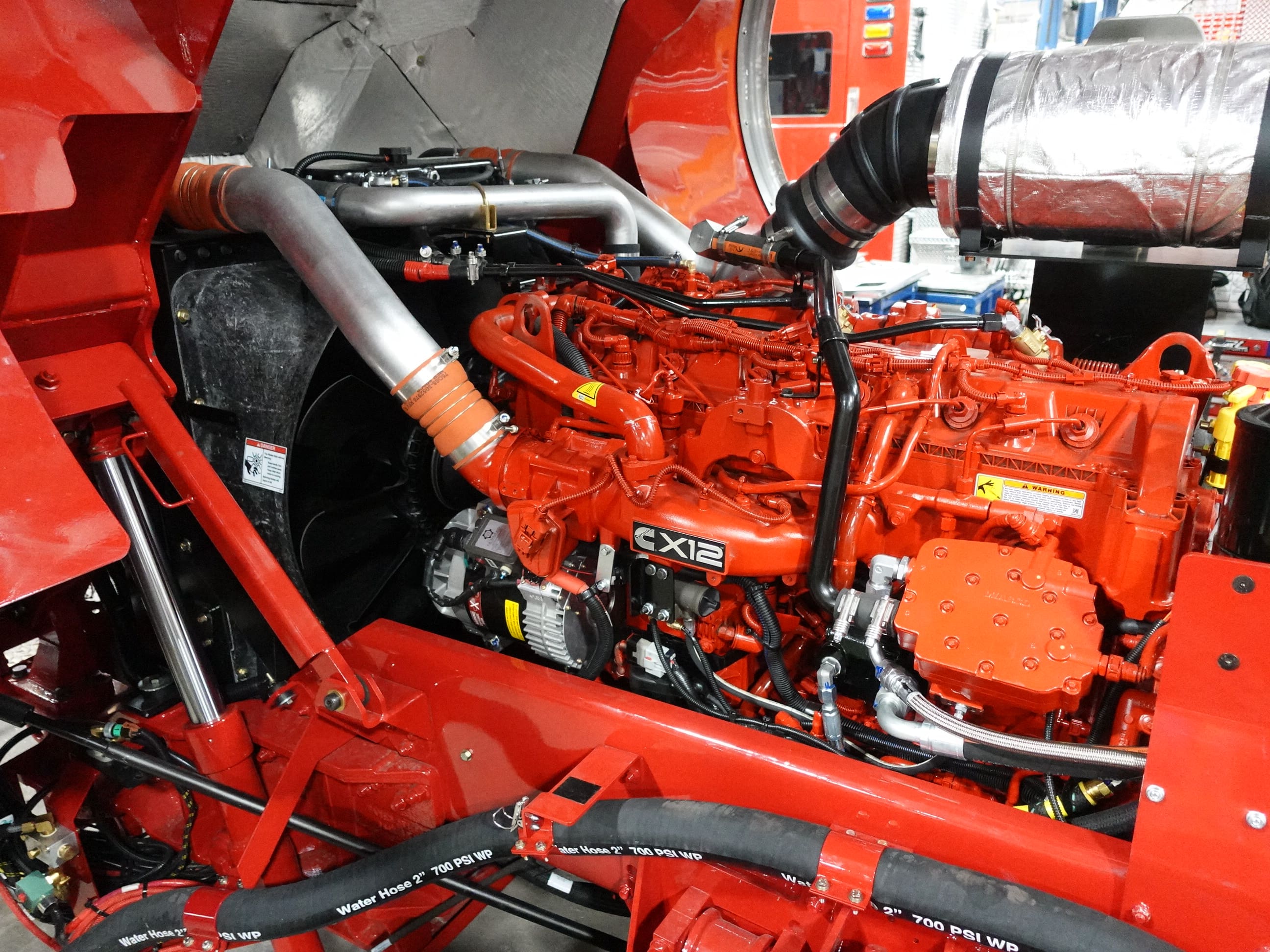

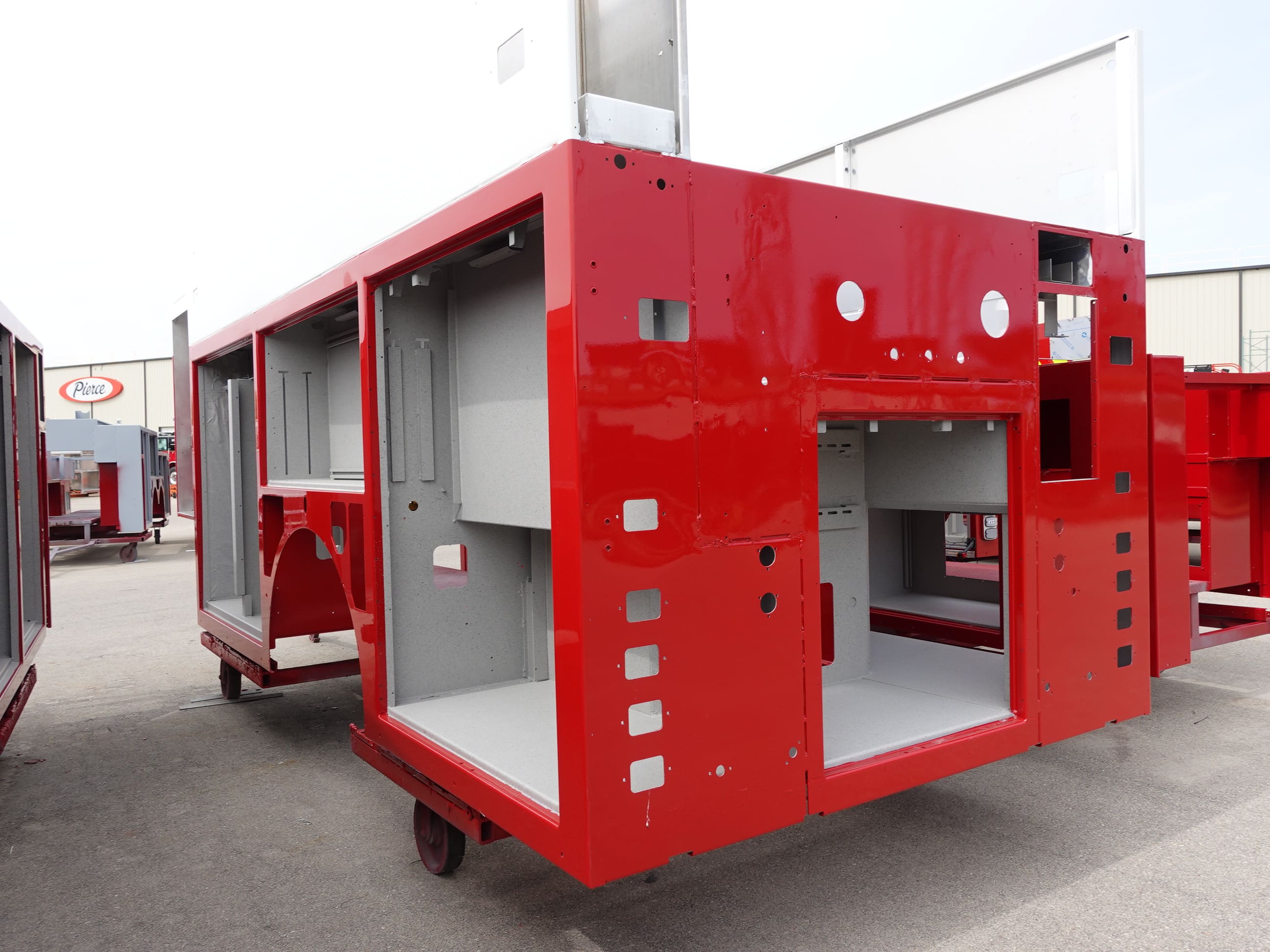

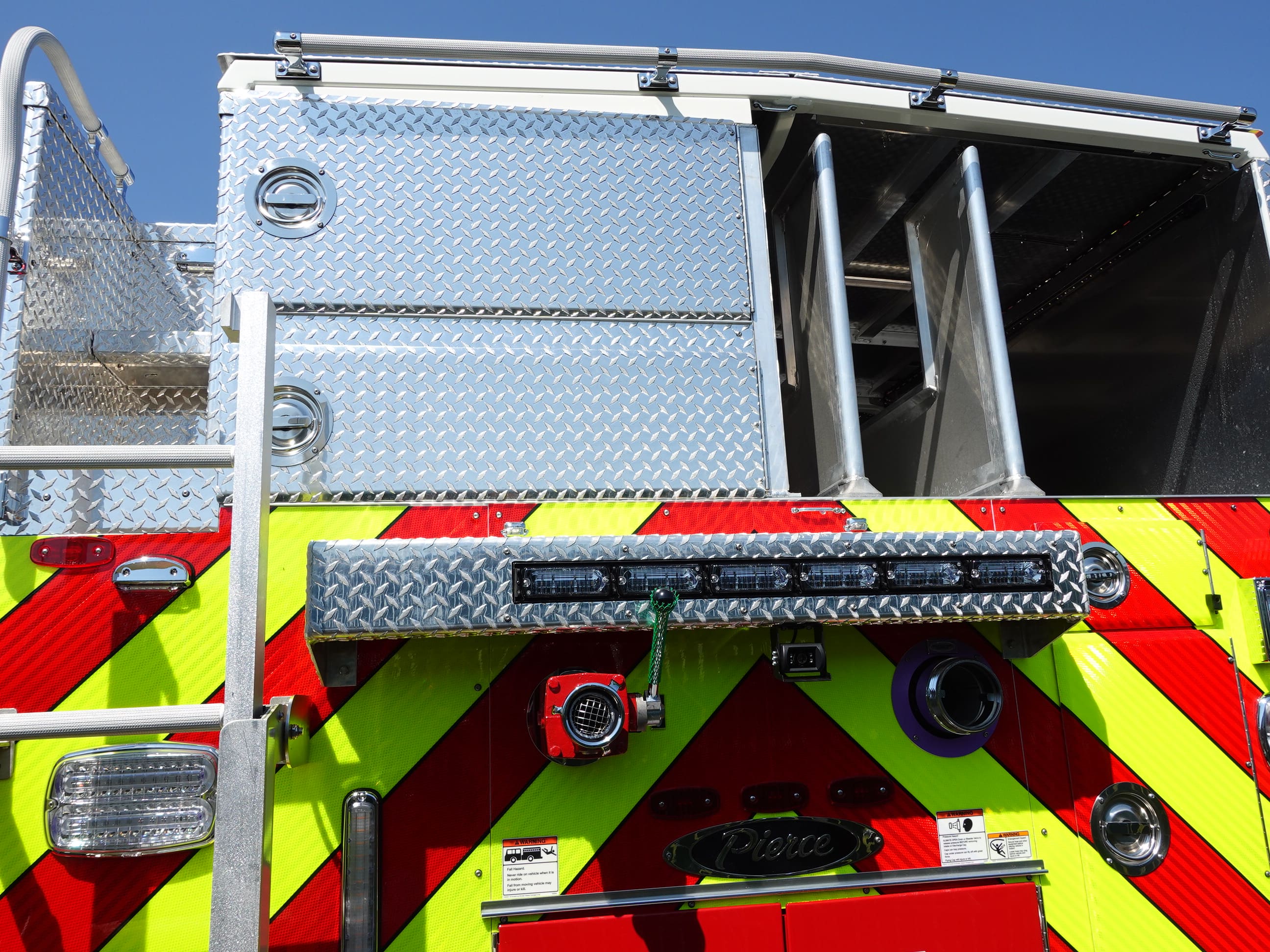

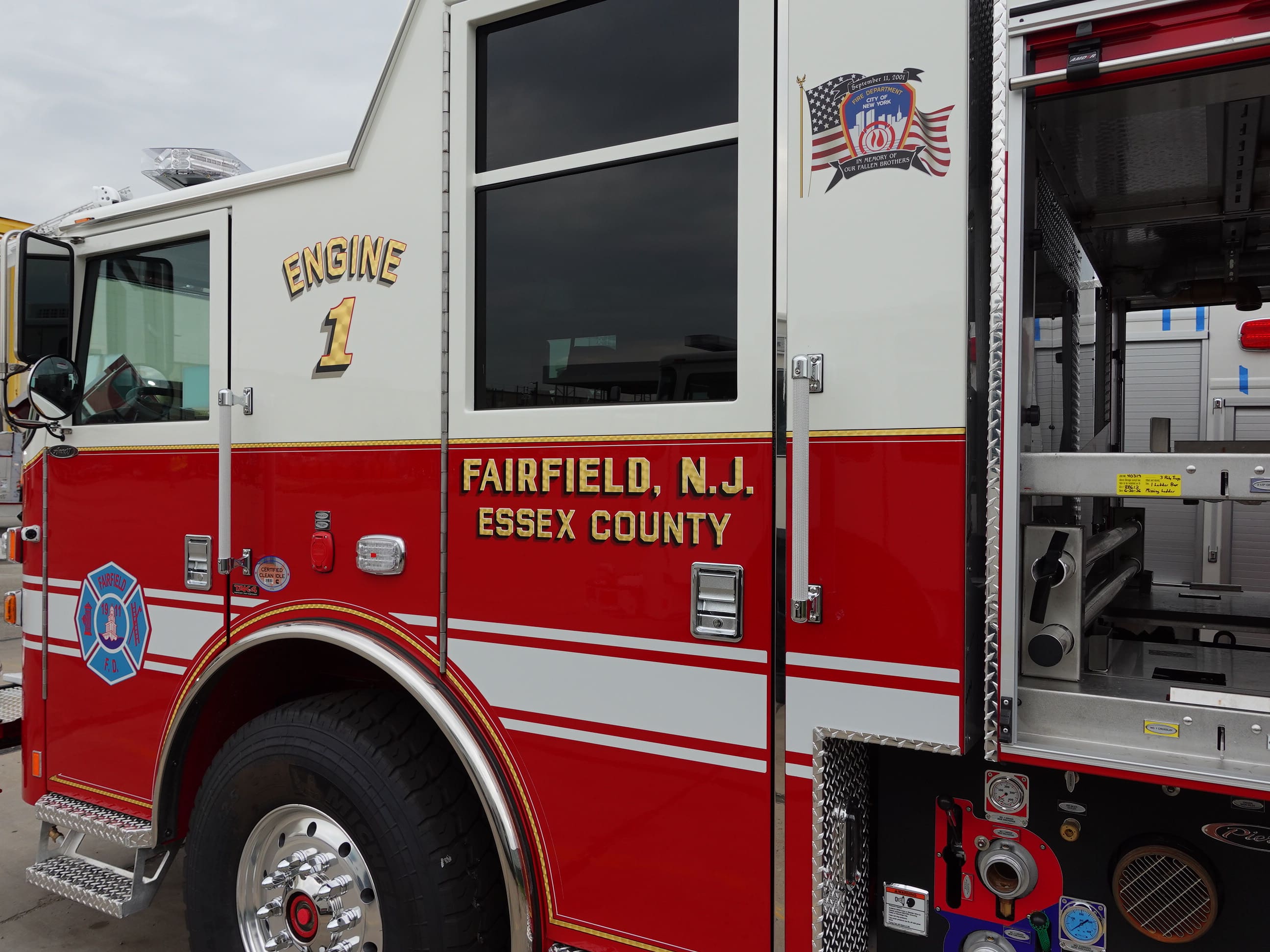

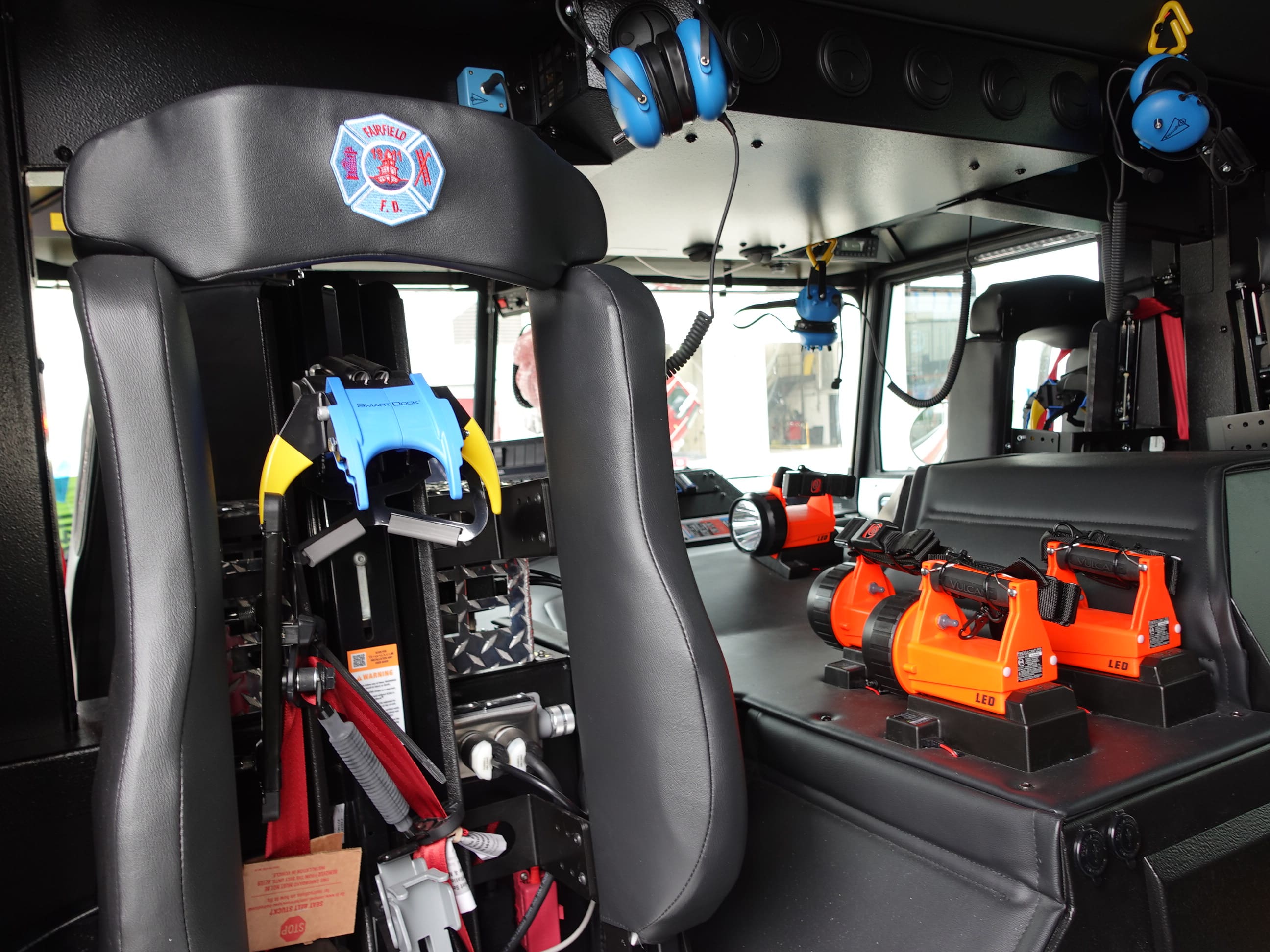

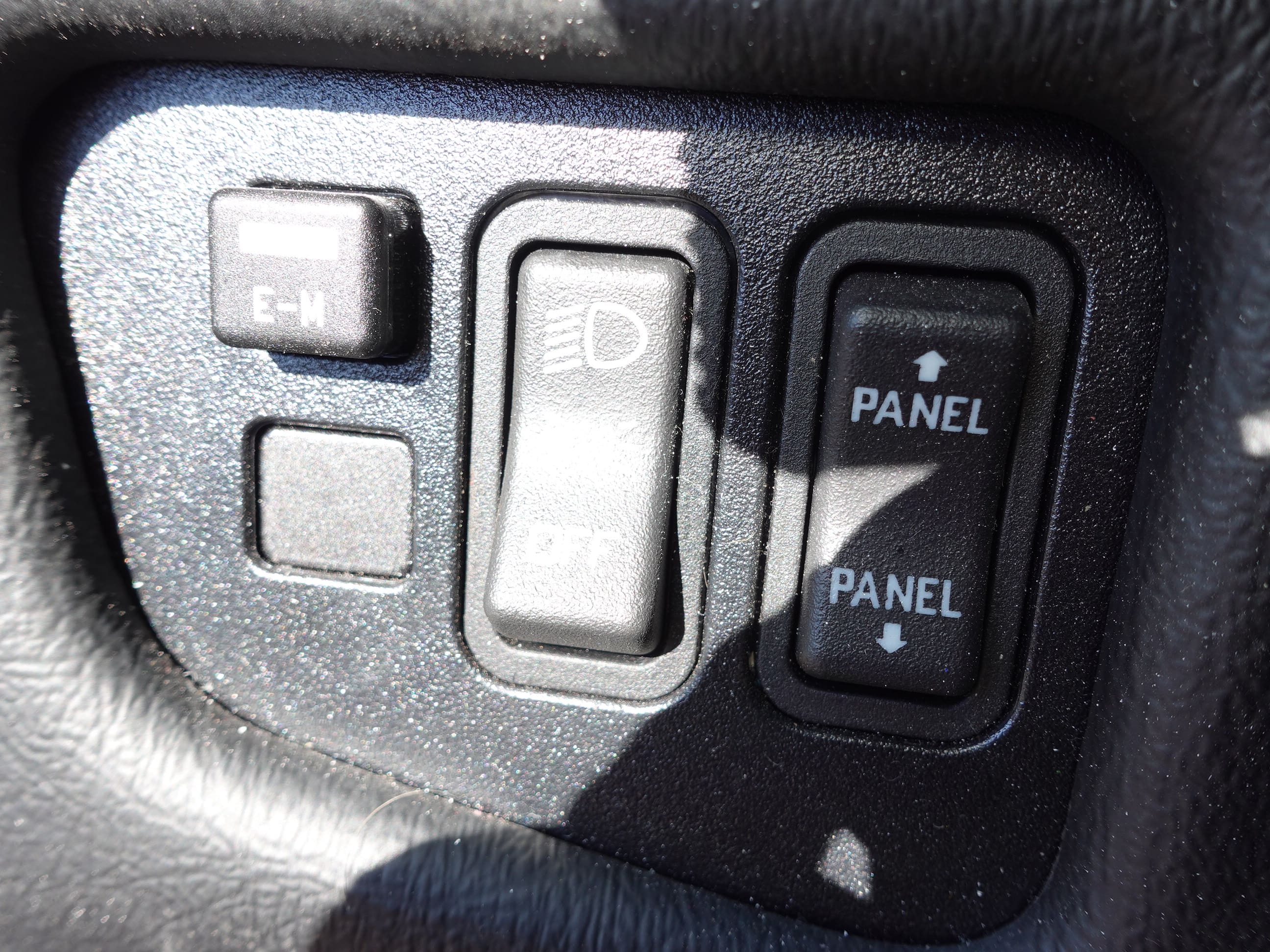

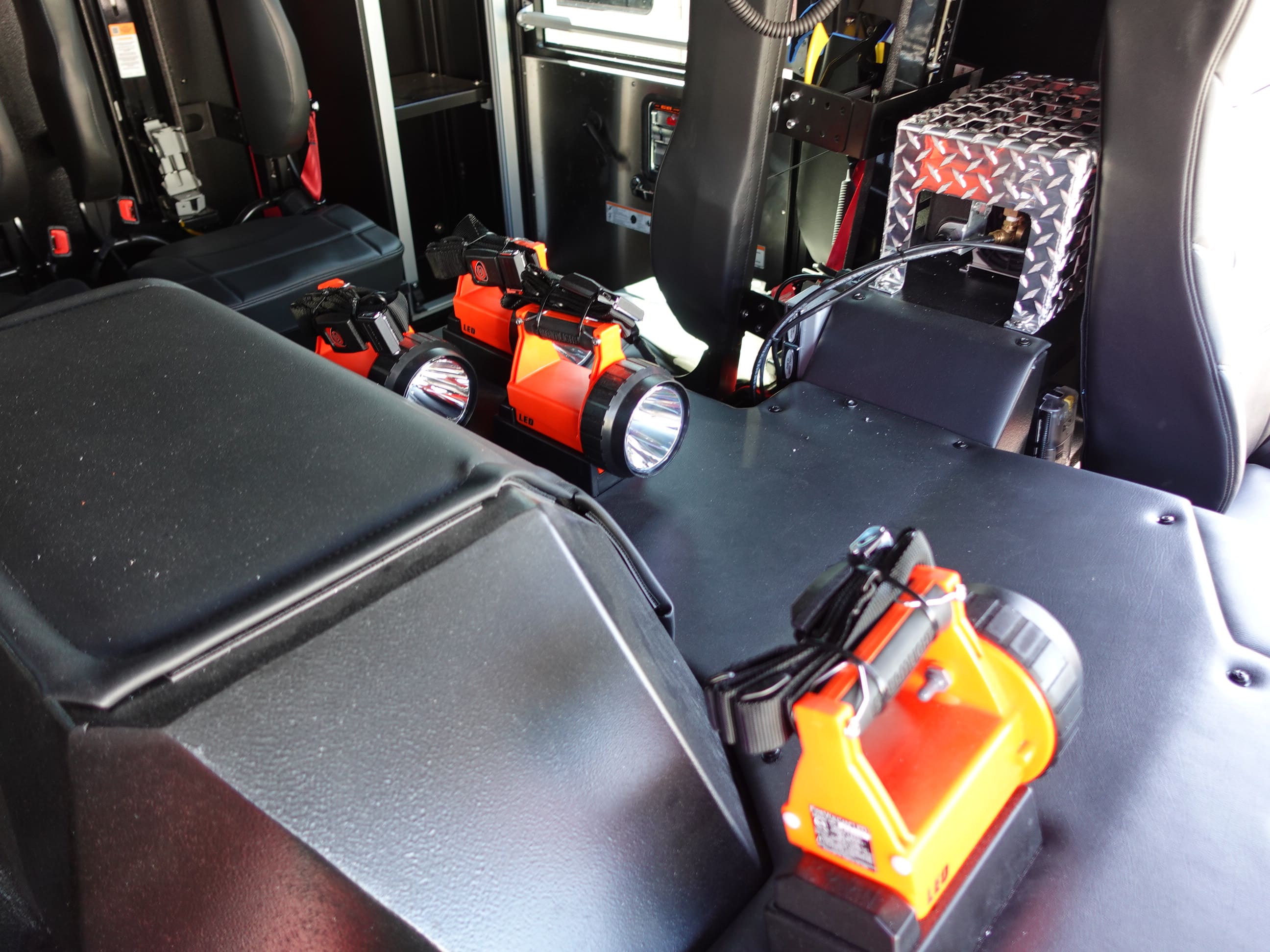

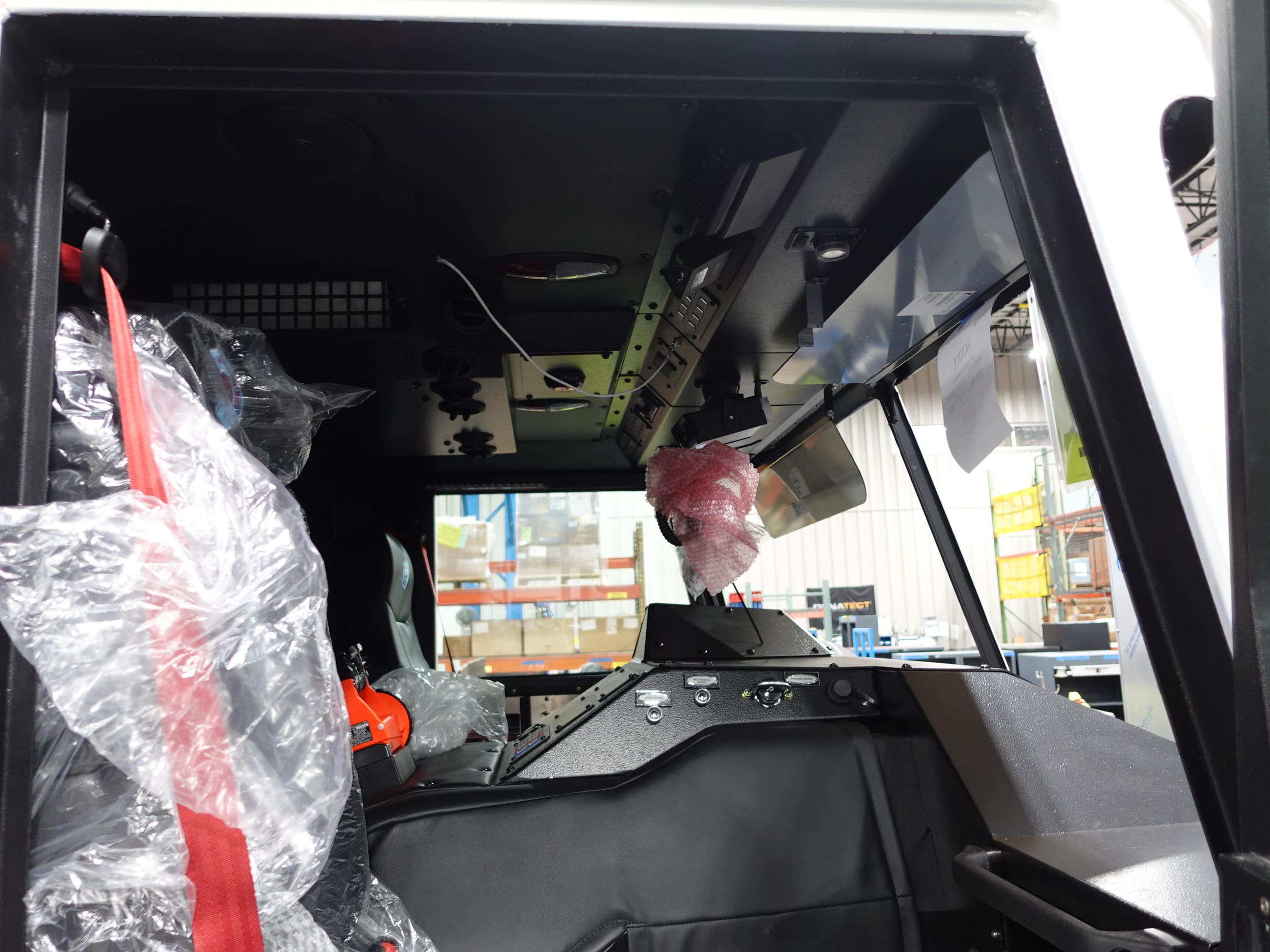

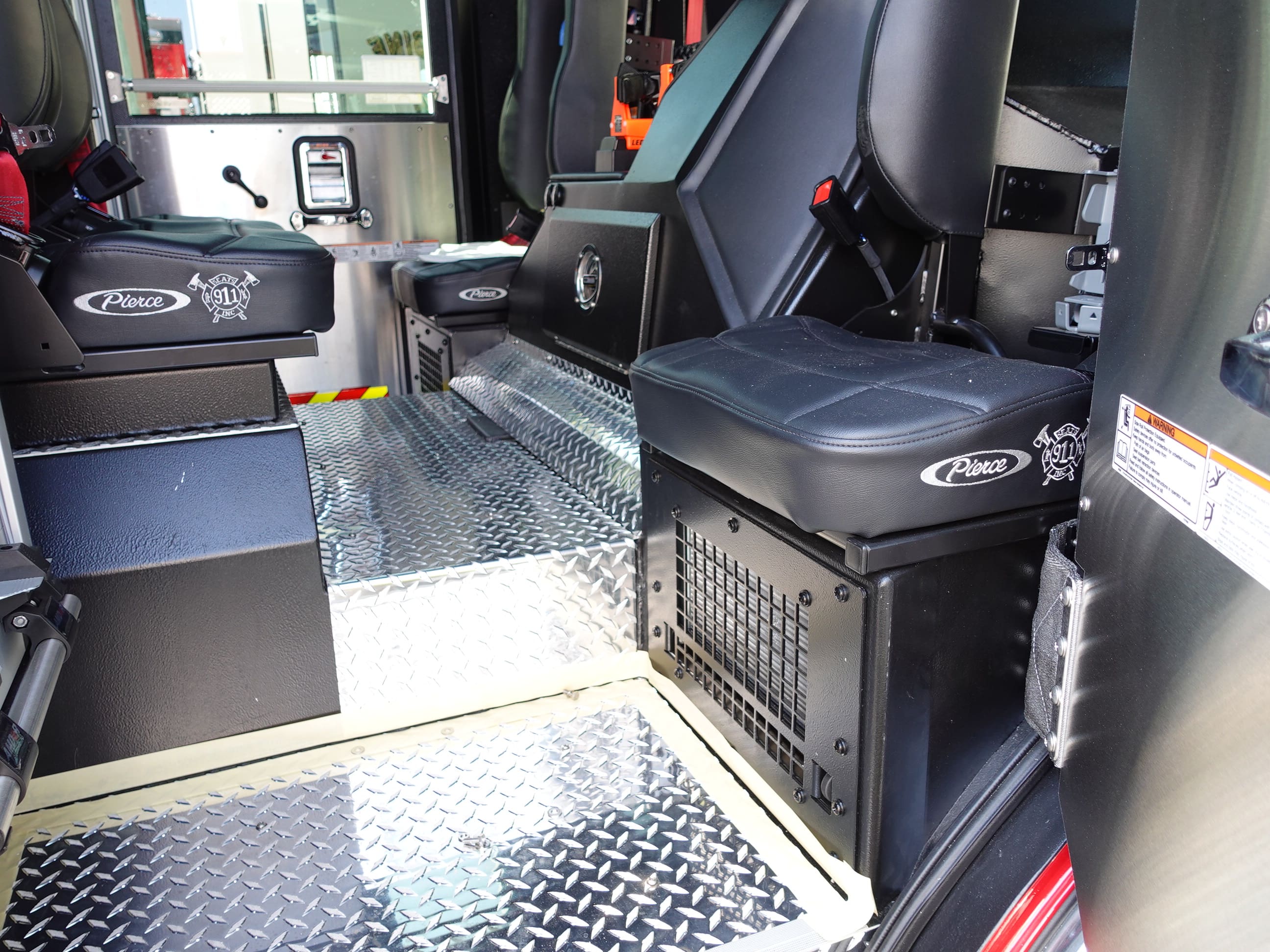

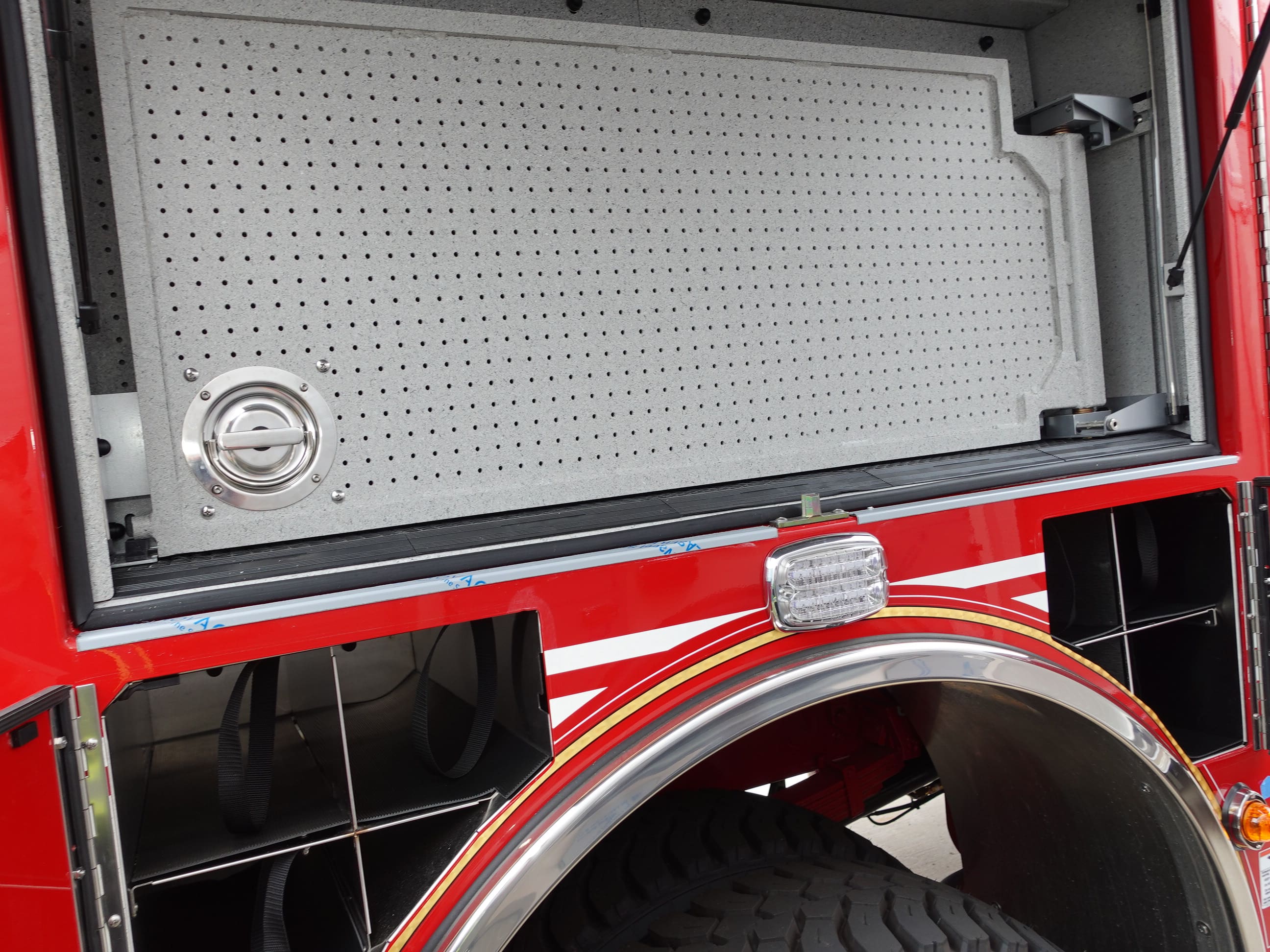

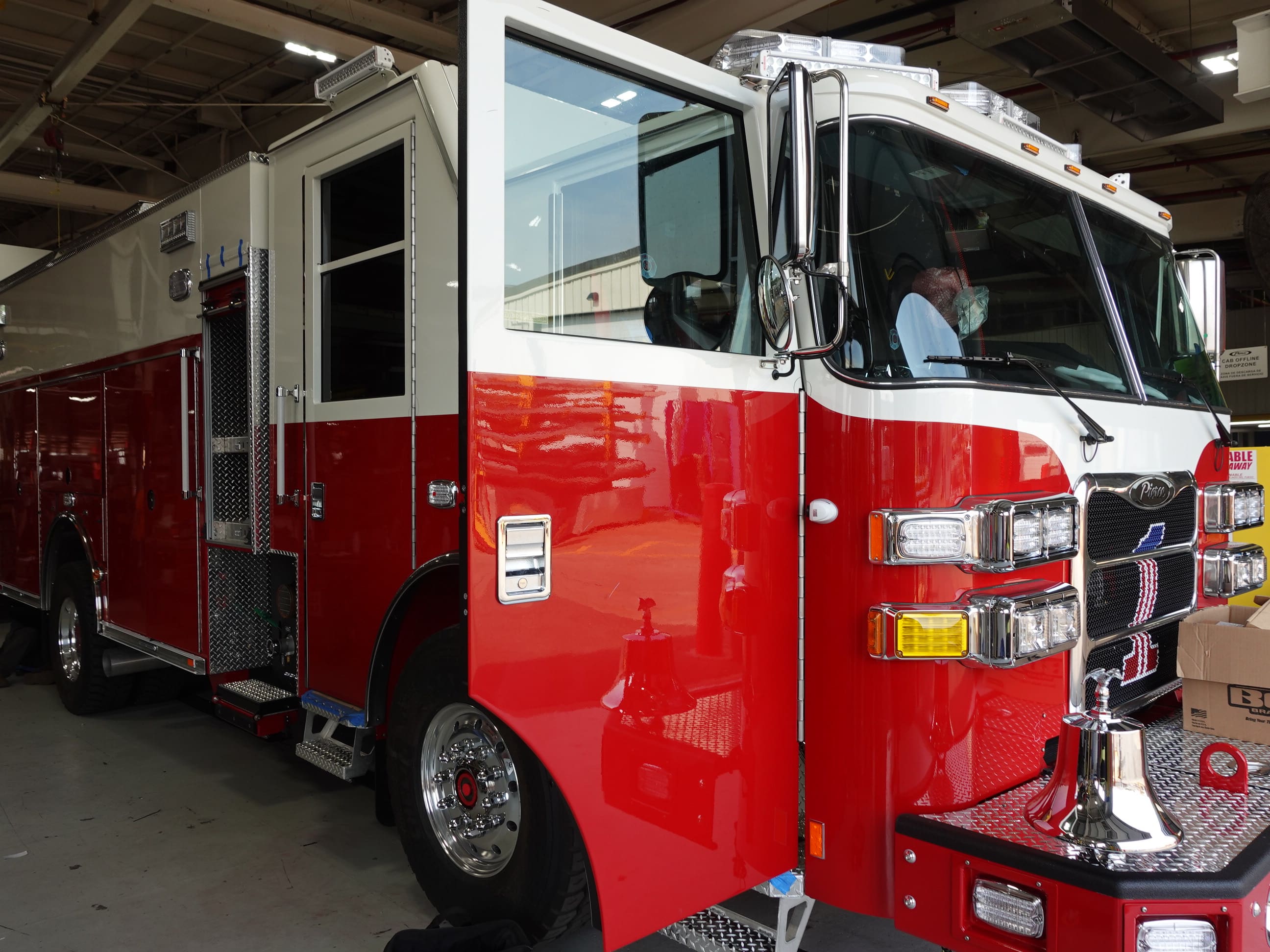

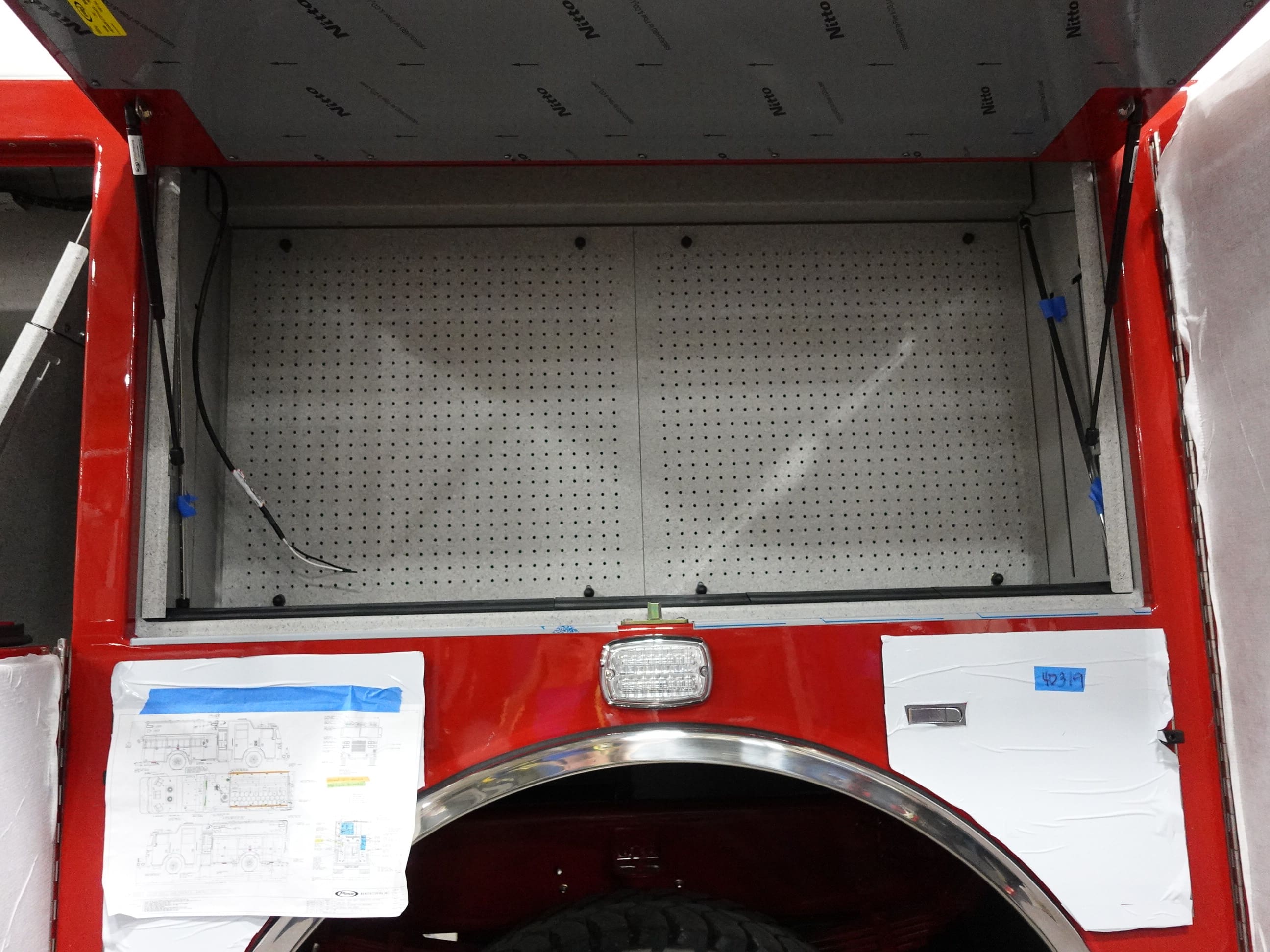

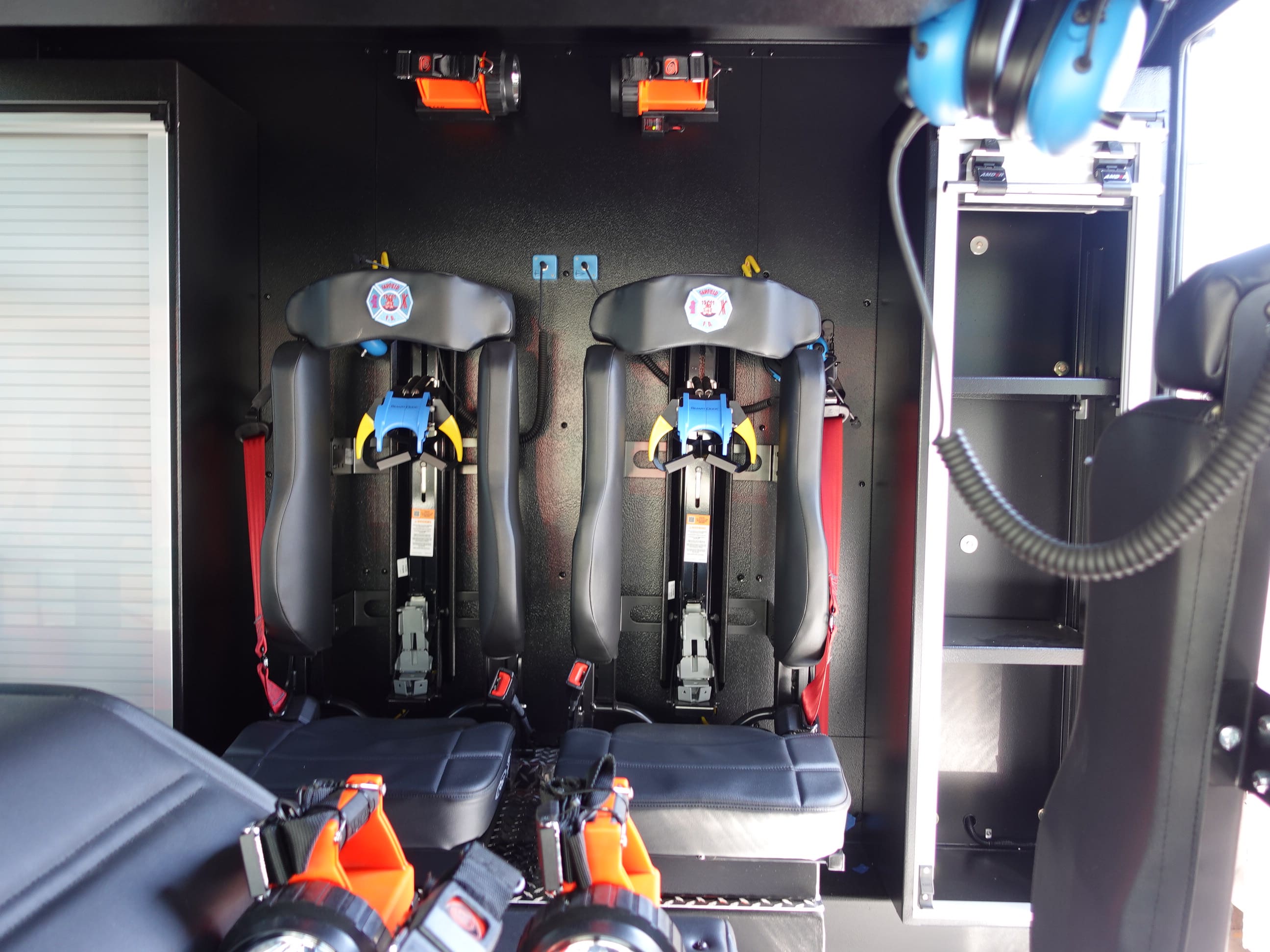

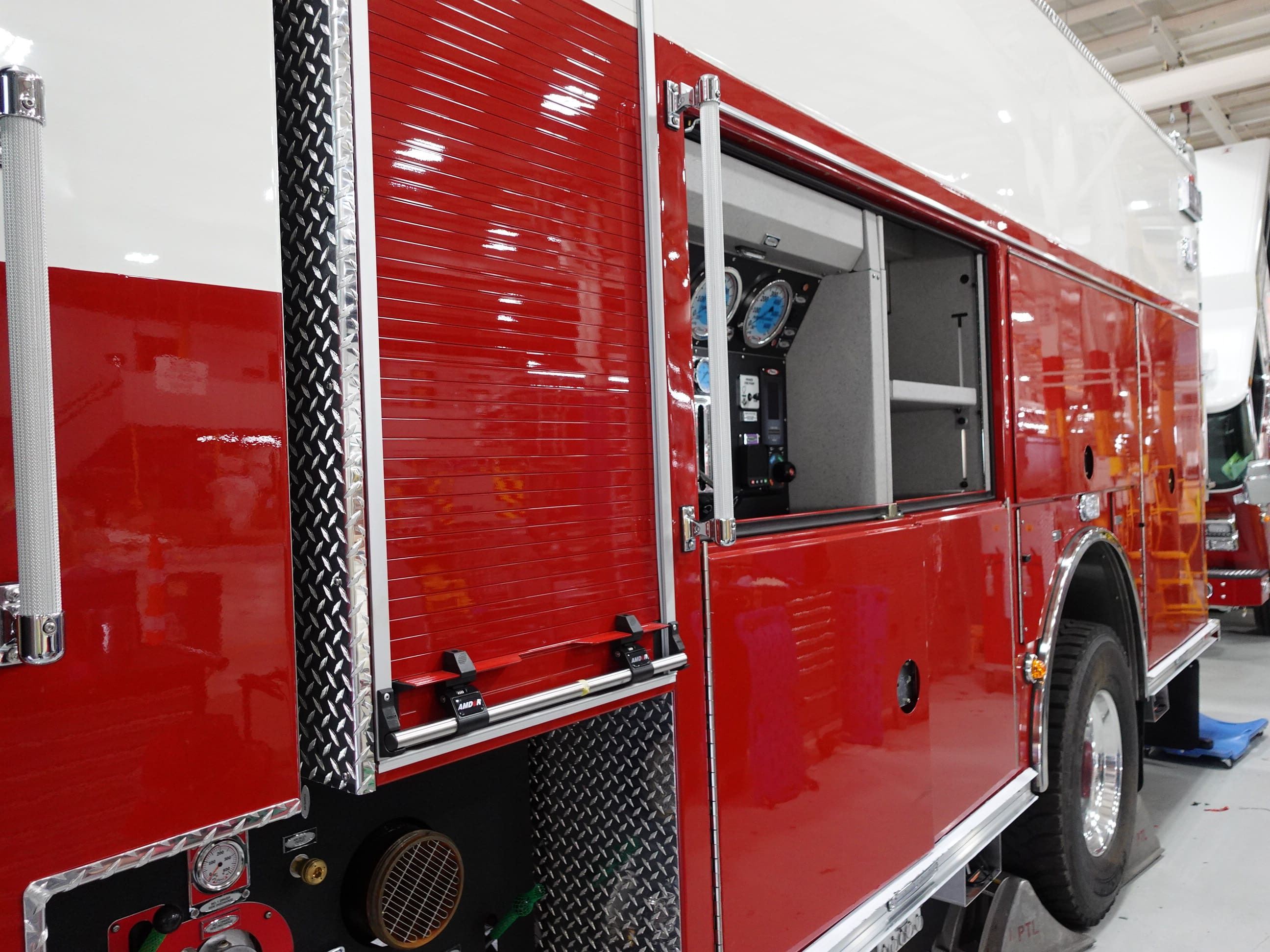

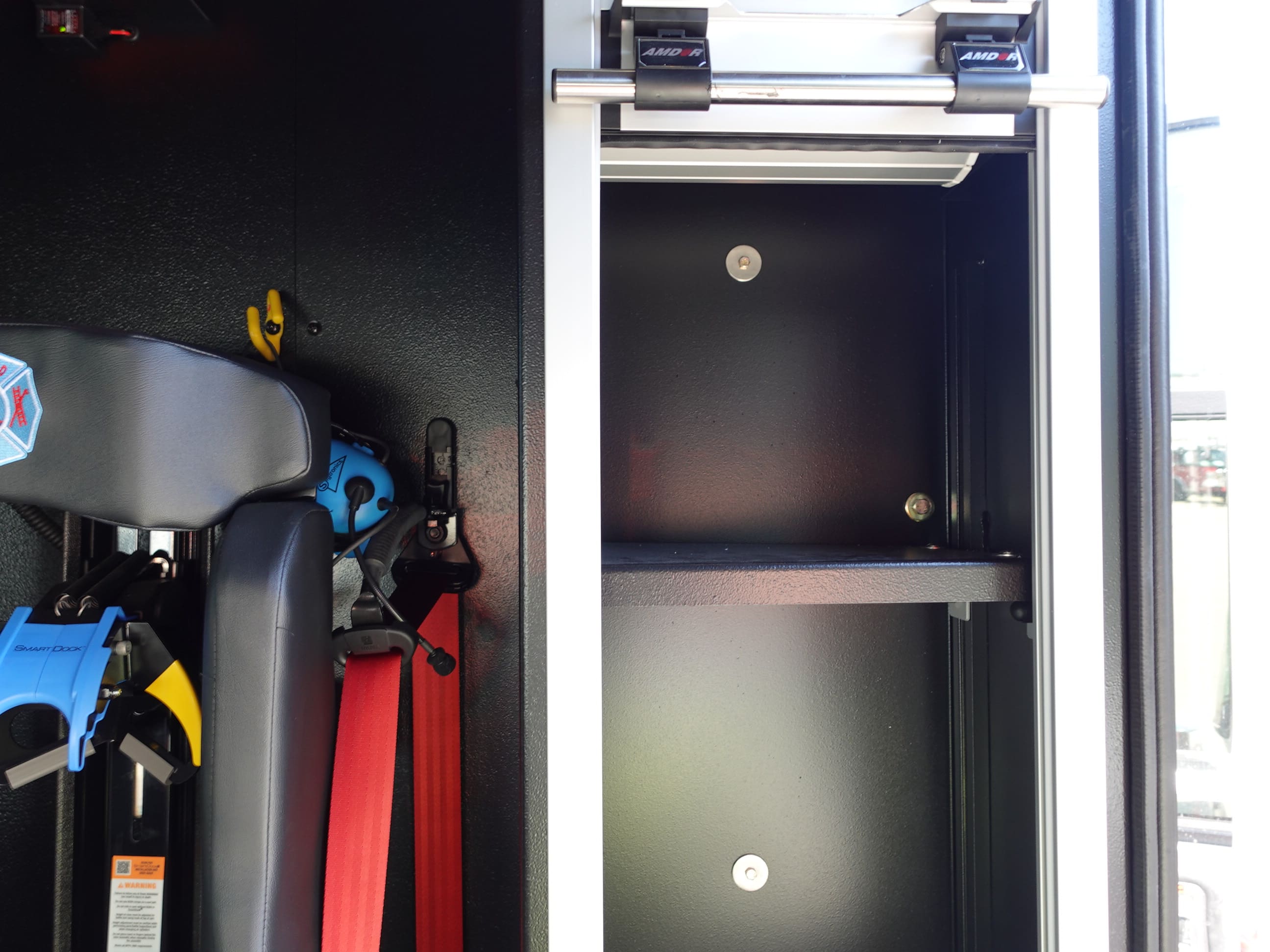

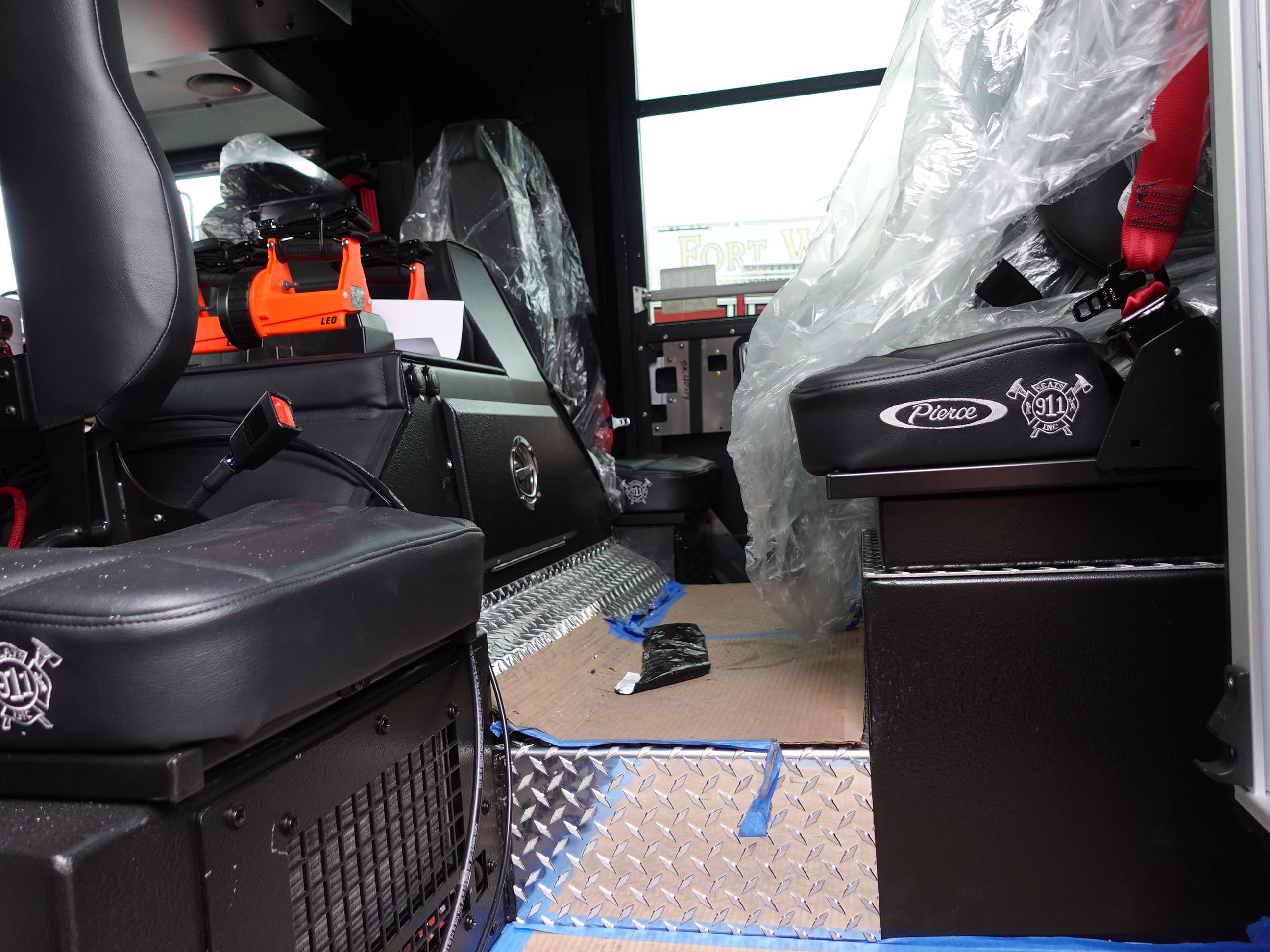

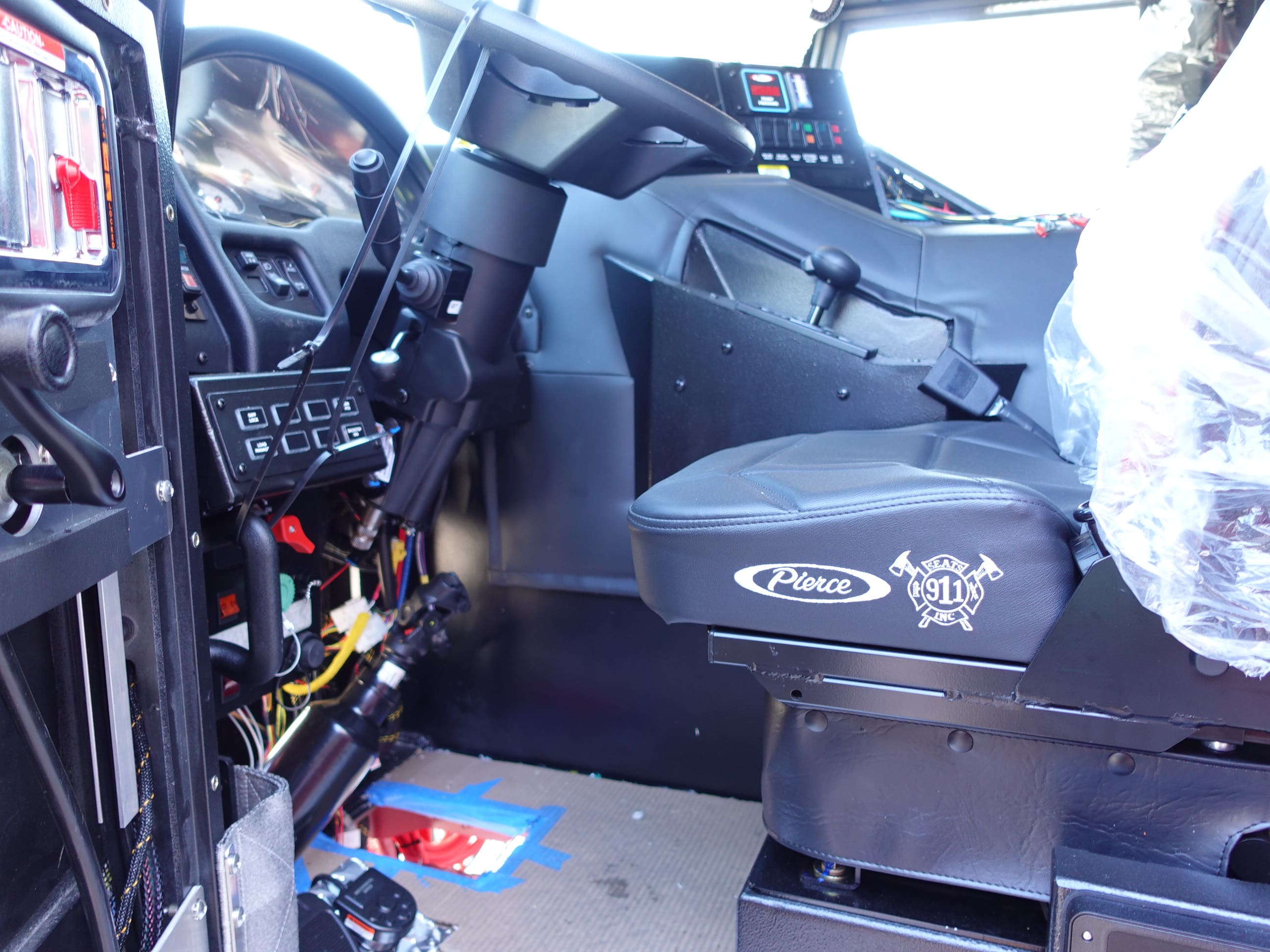

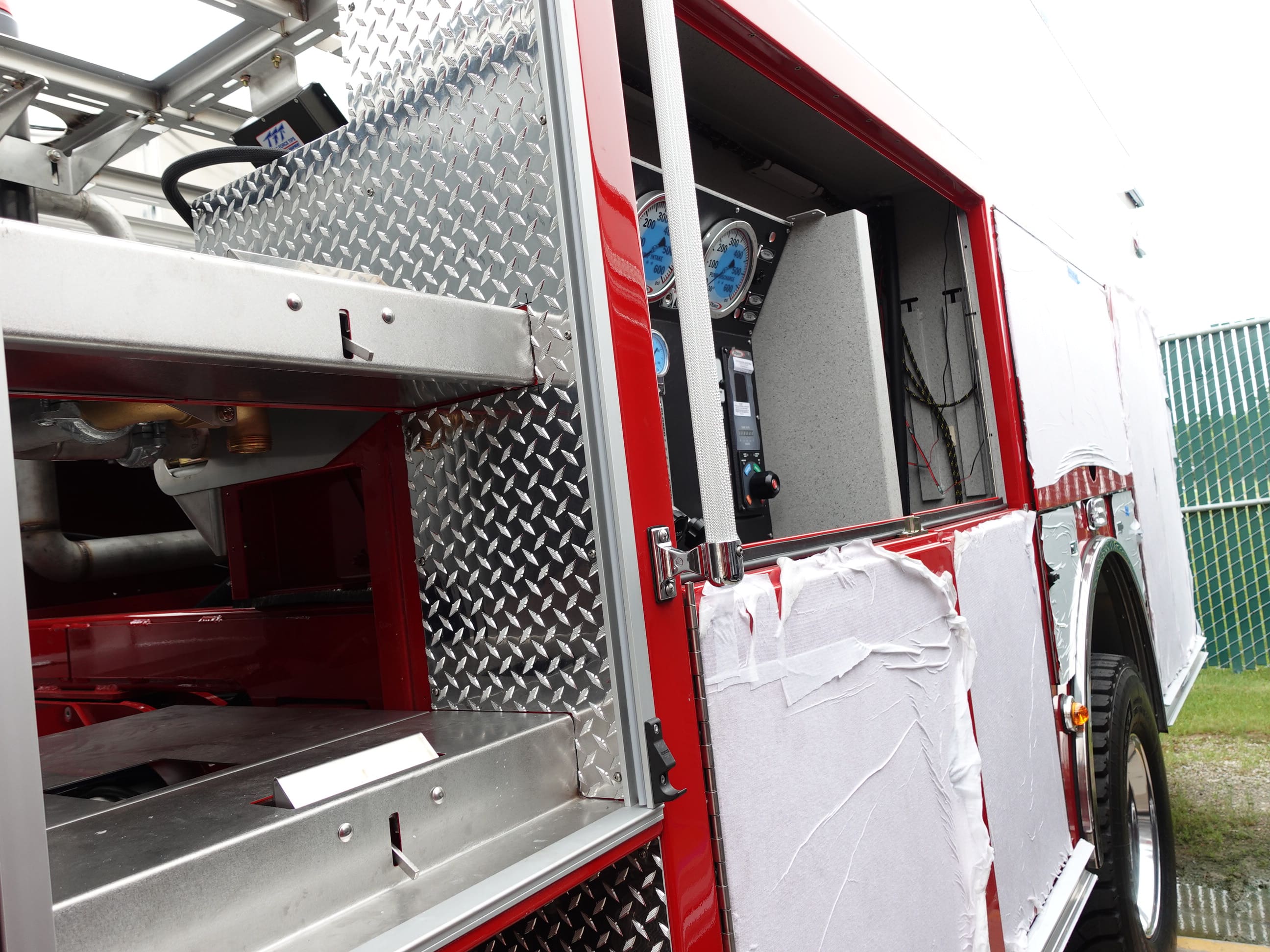

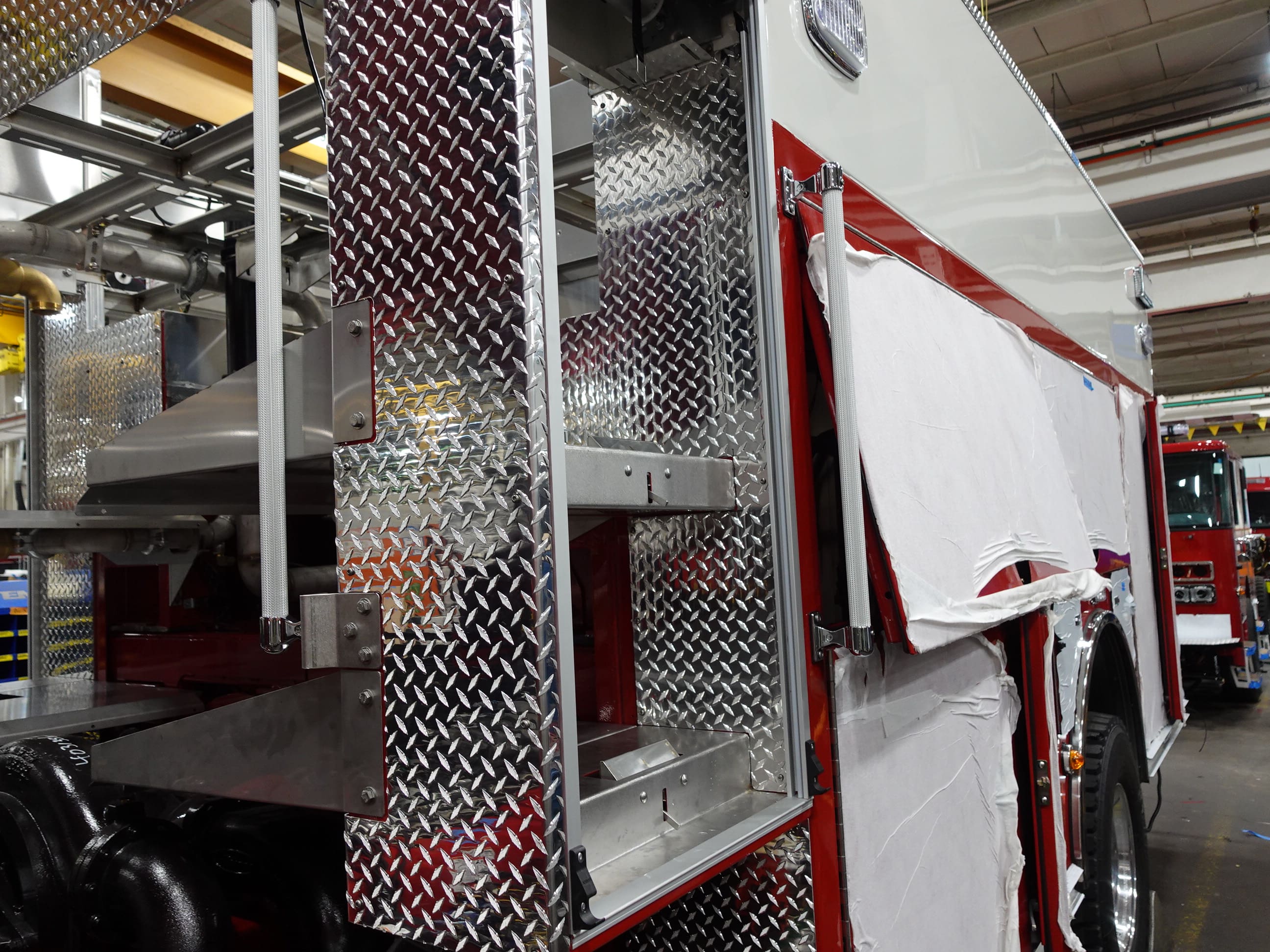

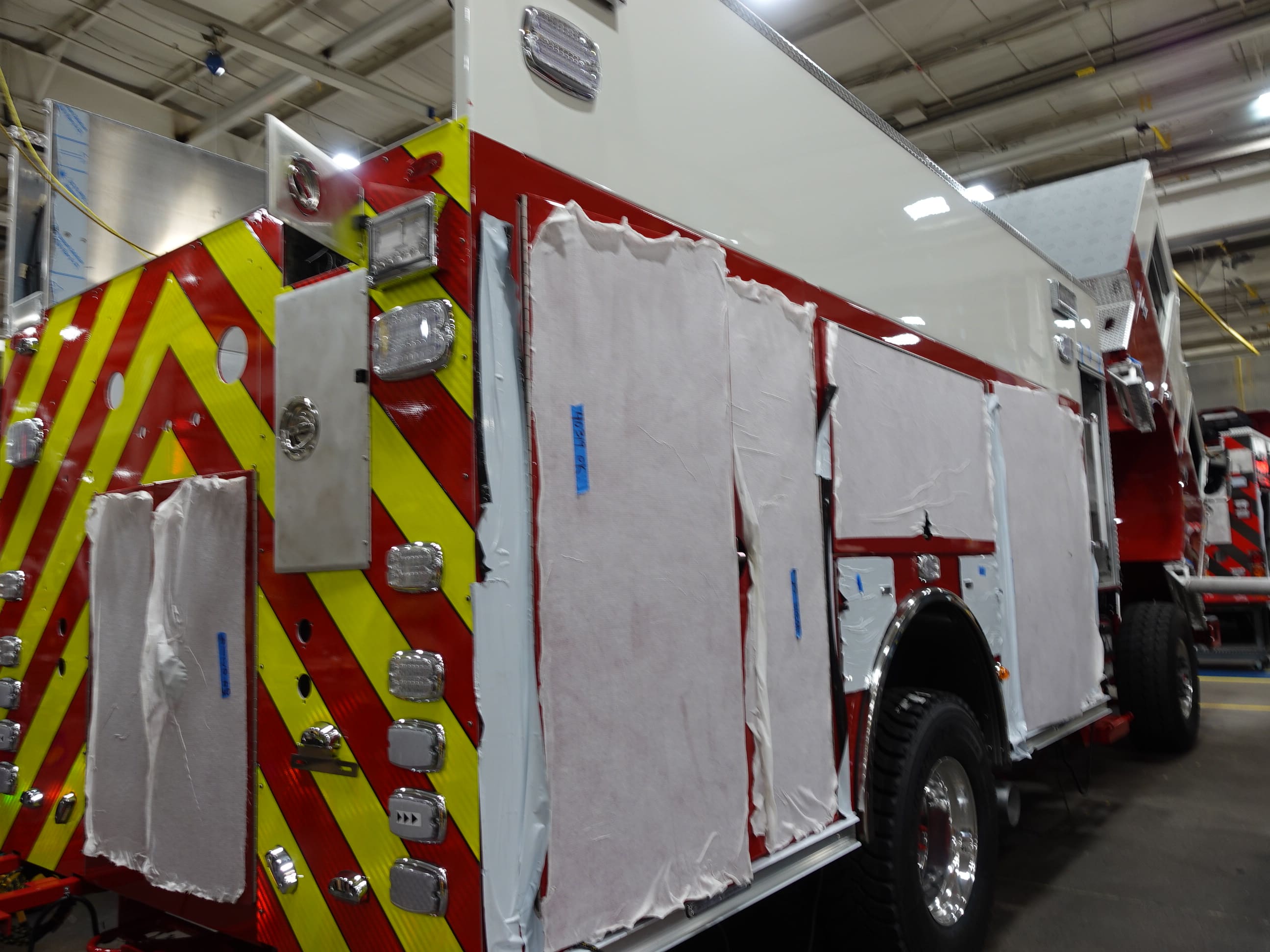

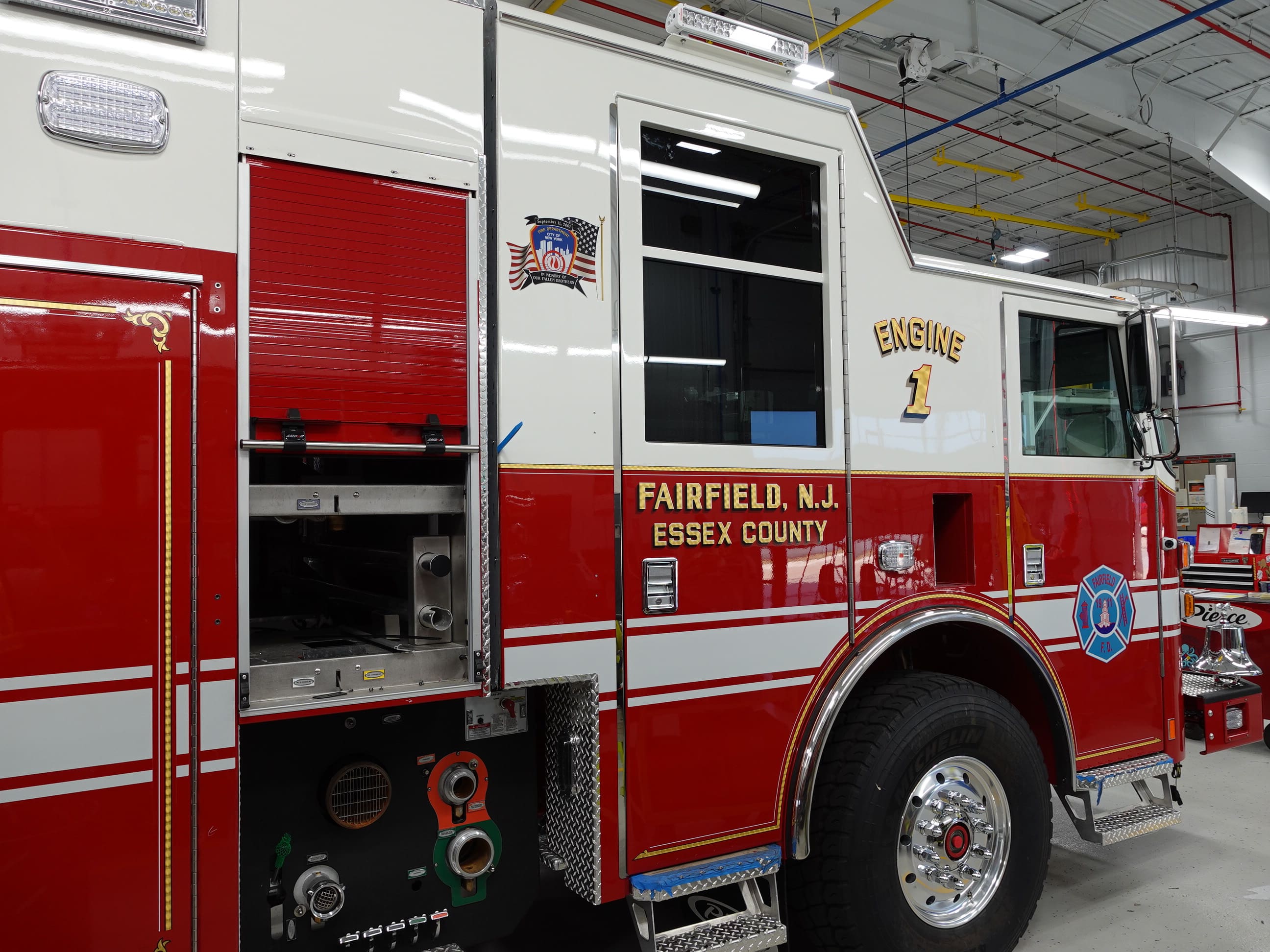

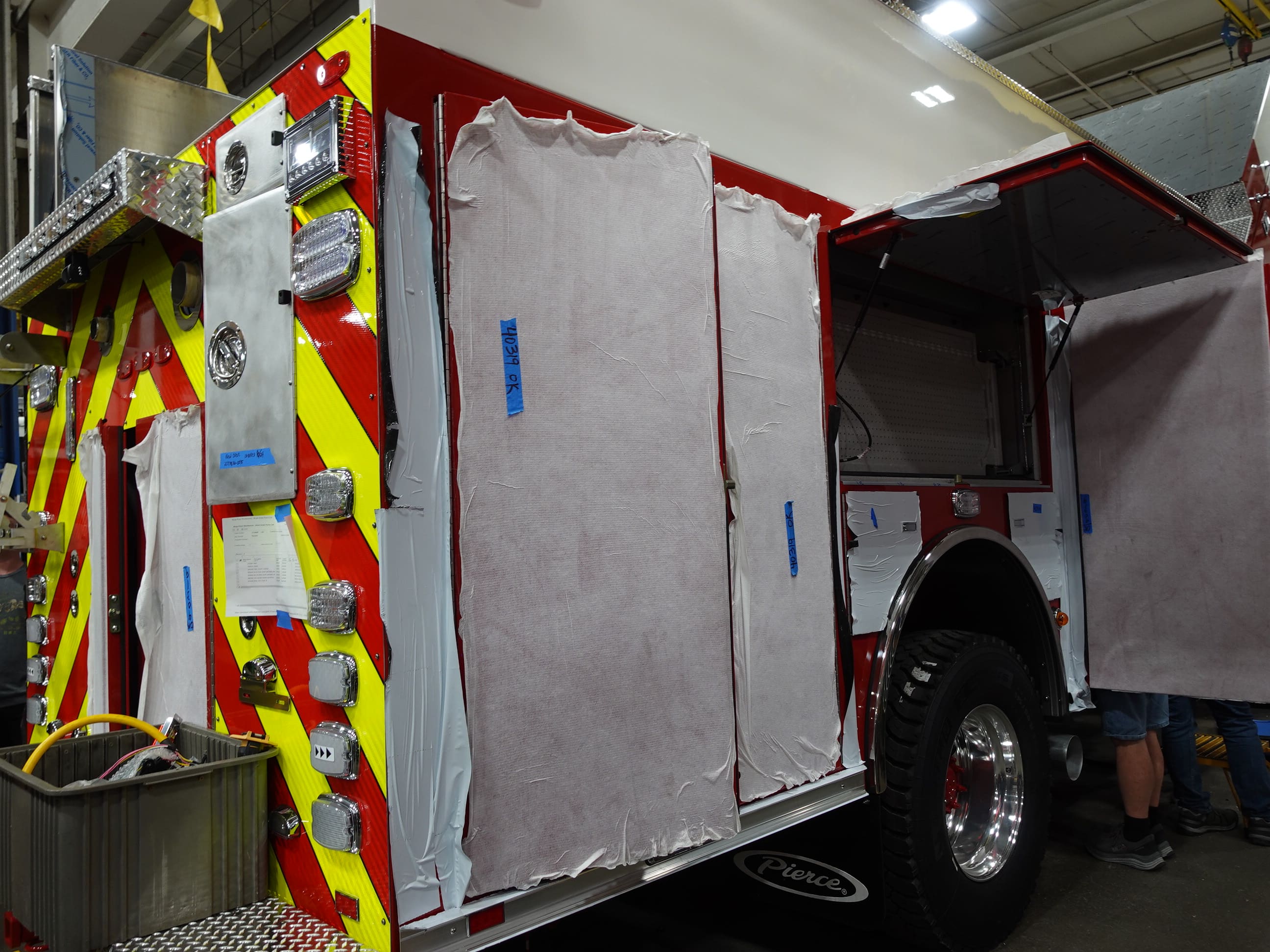

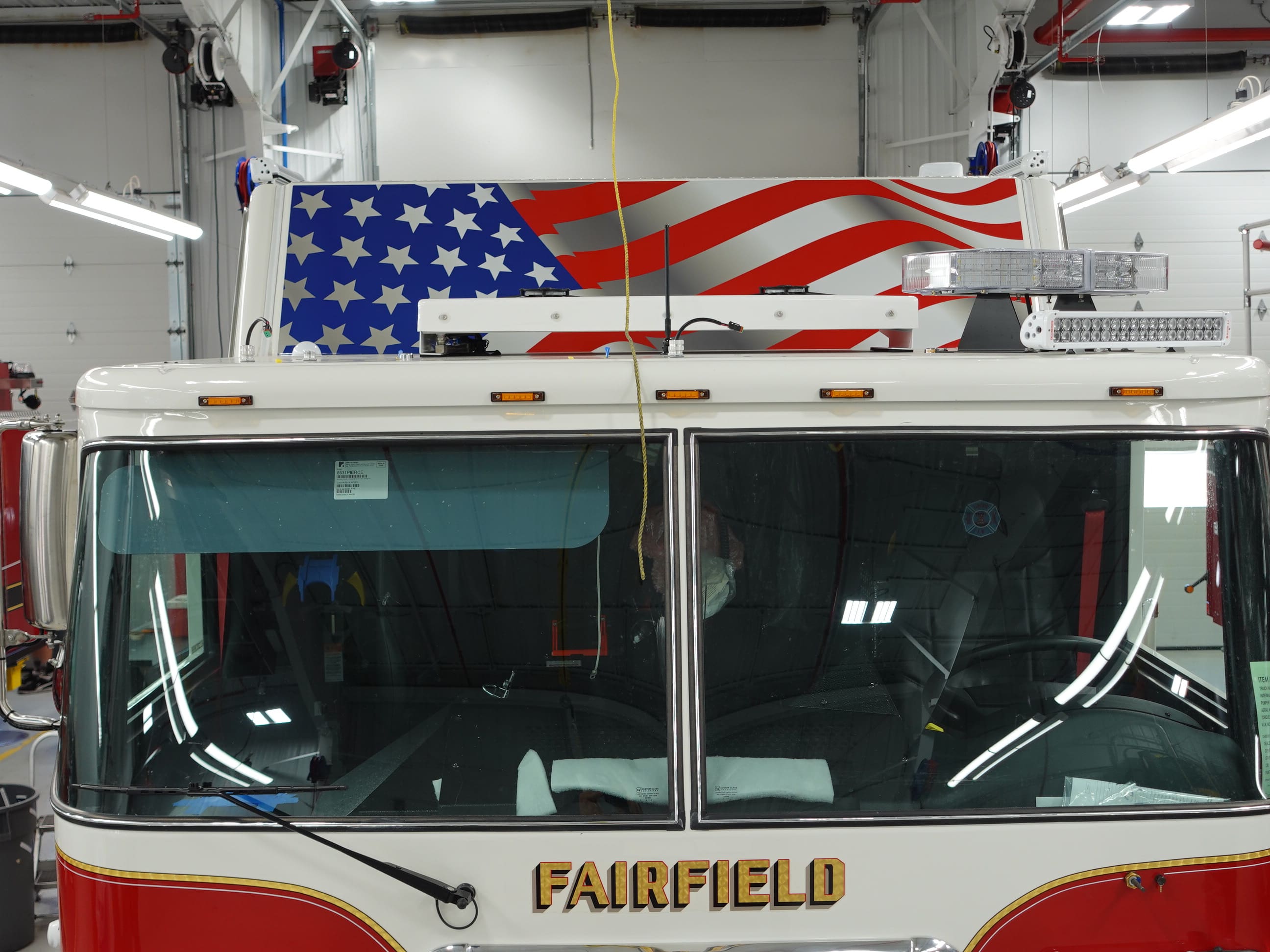

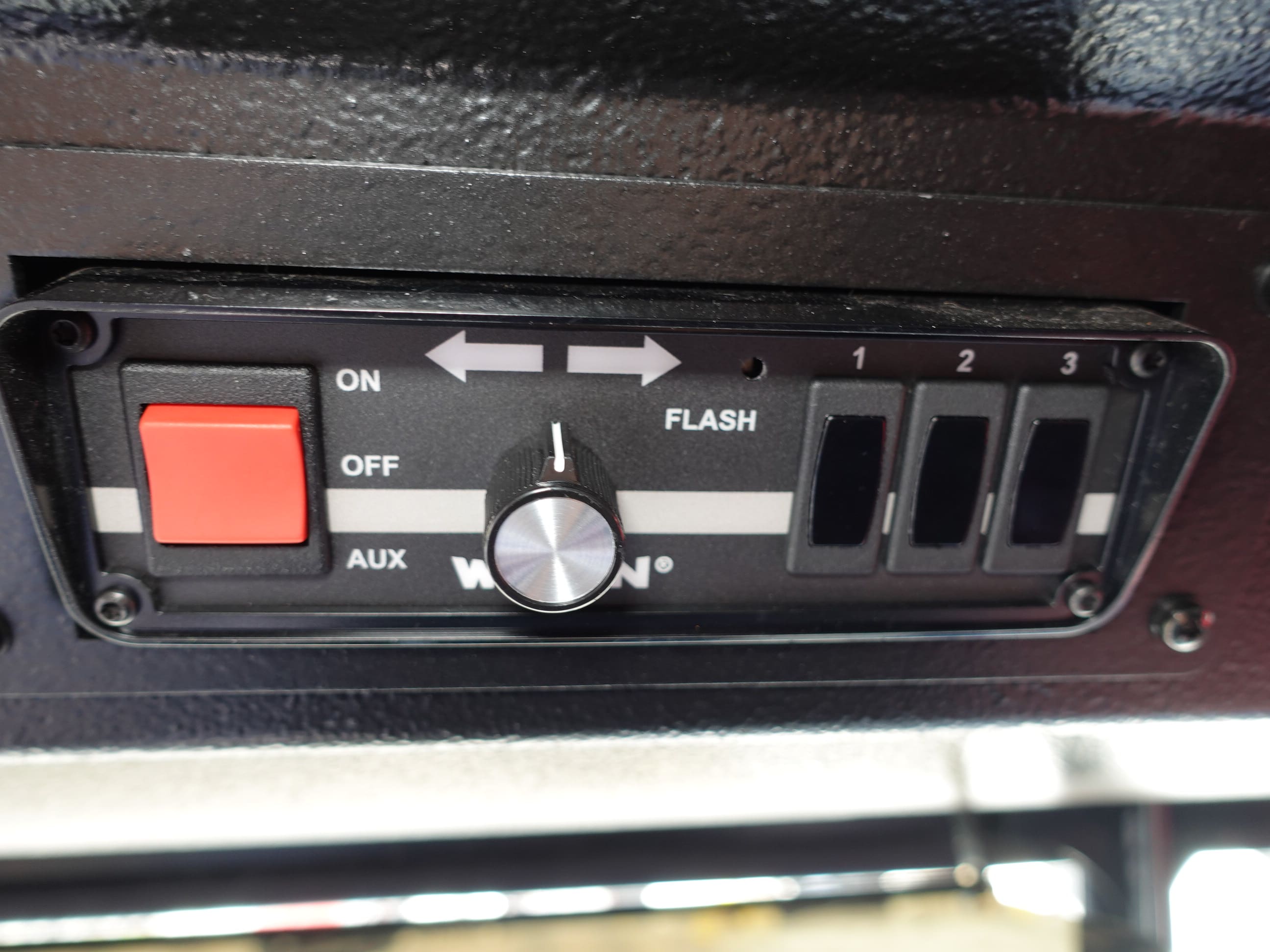

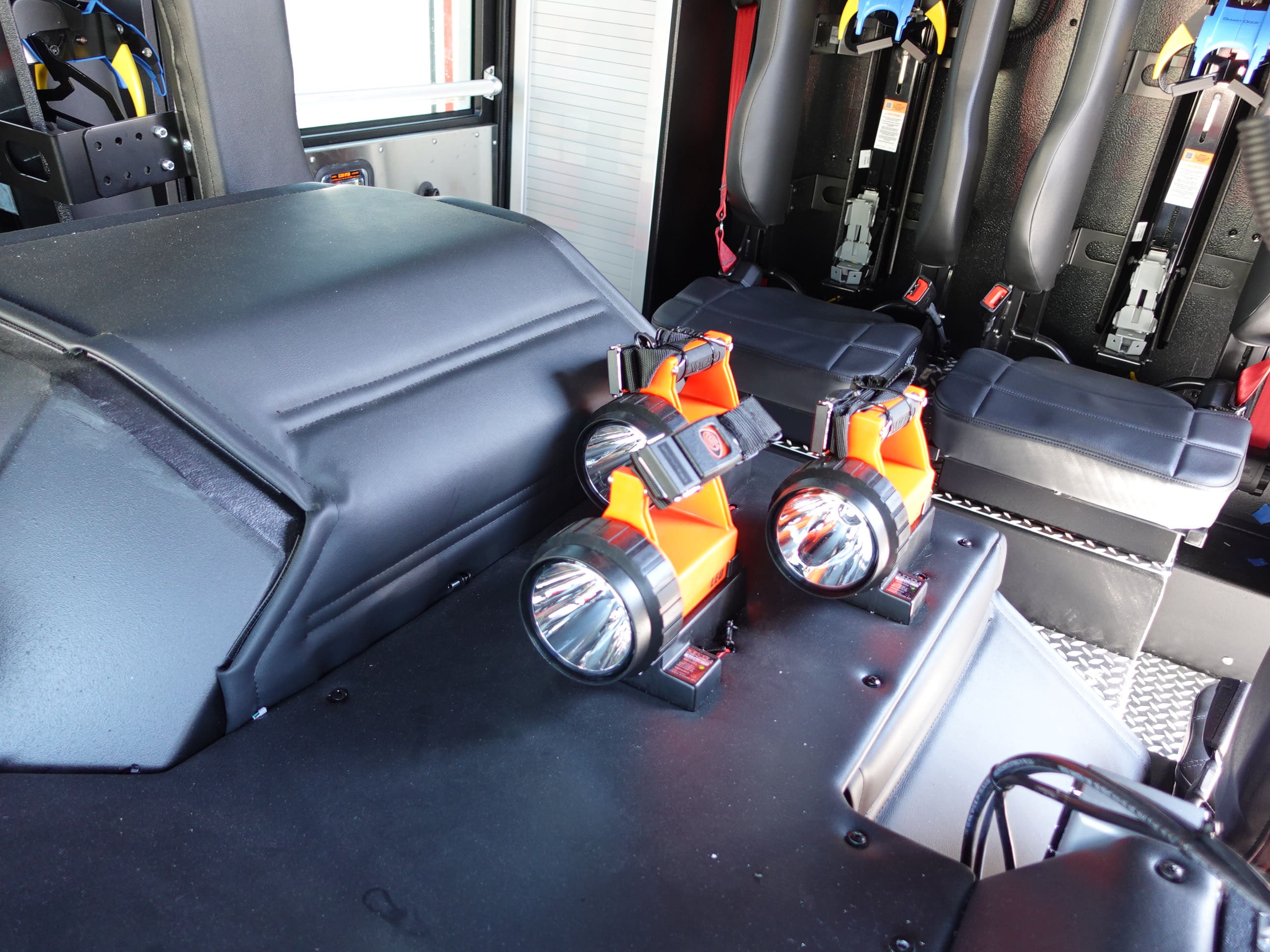

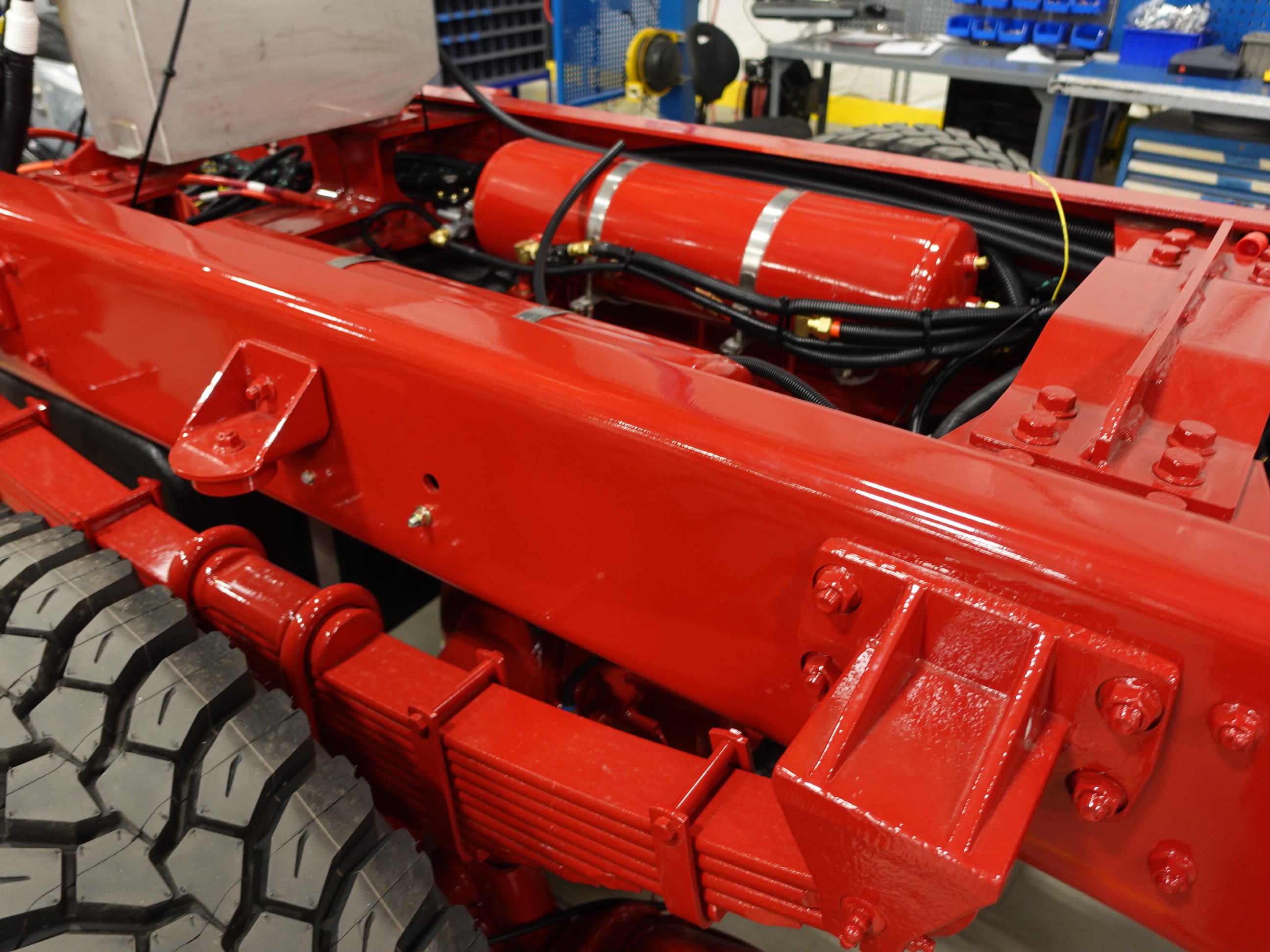

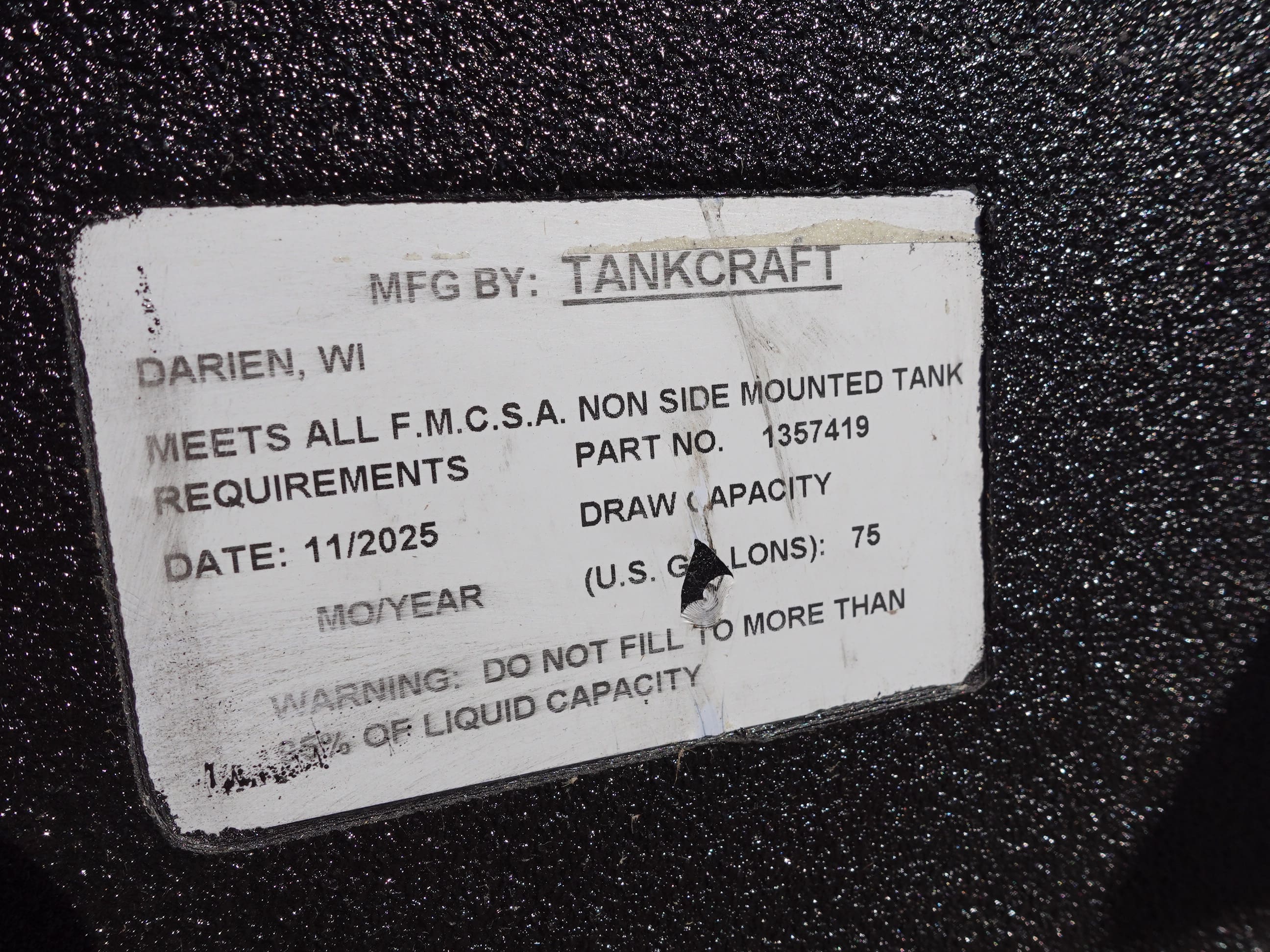

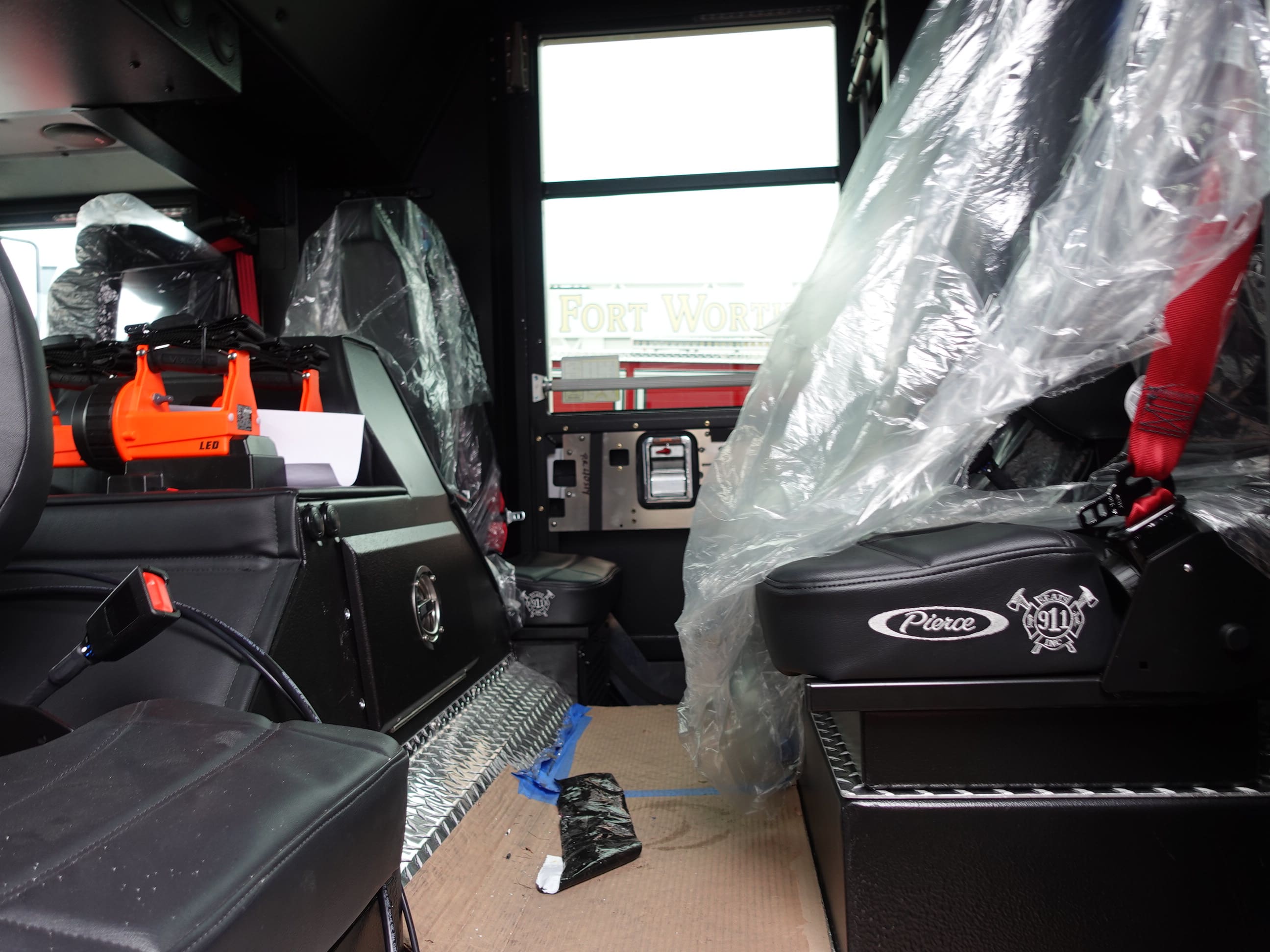

In this report, the apparatus was staged to complete the quality process where any remaining

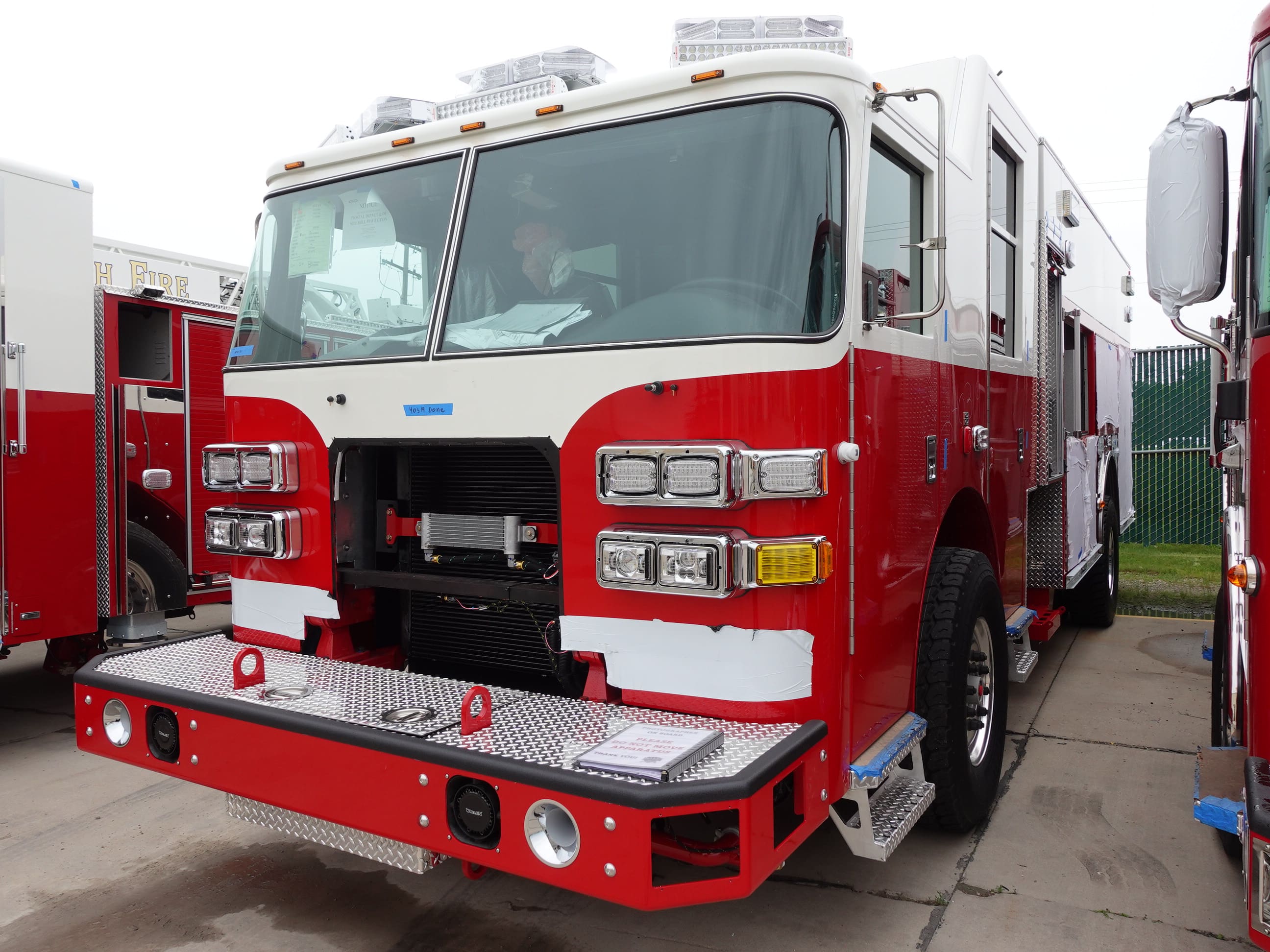

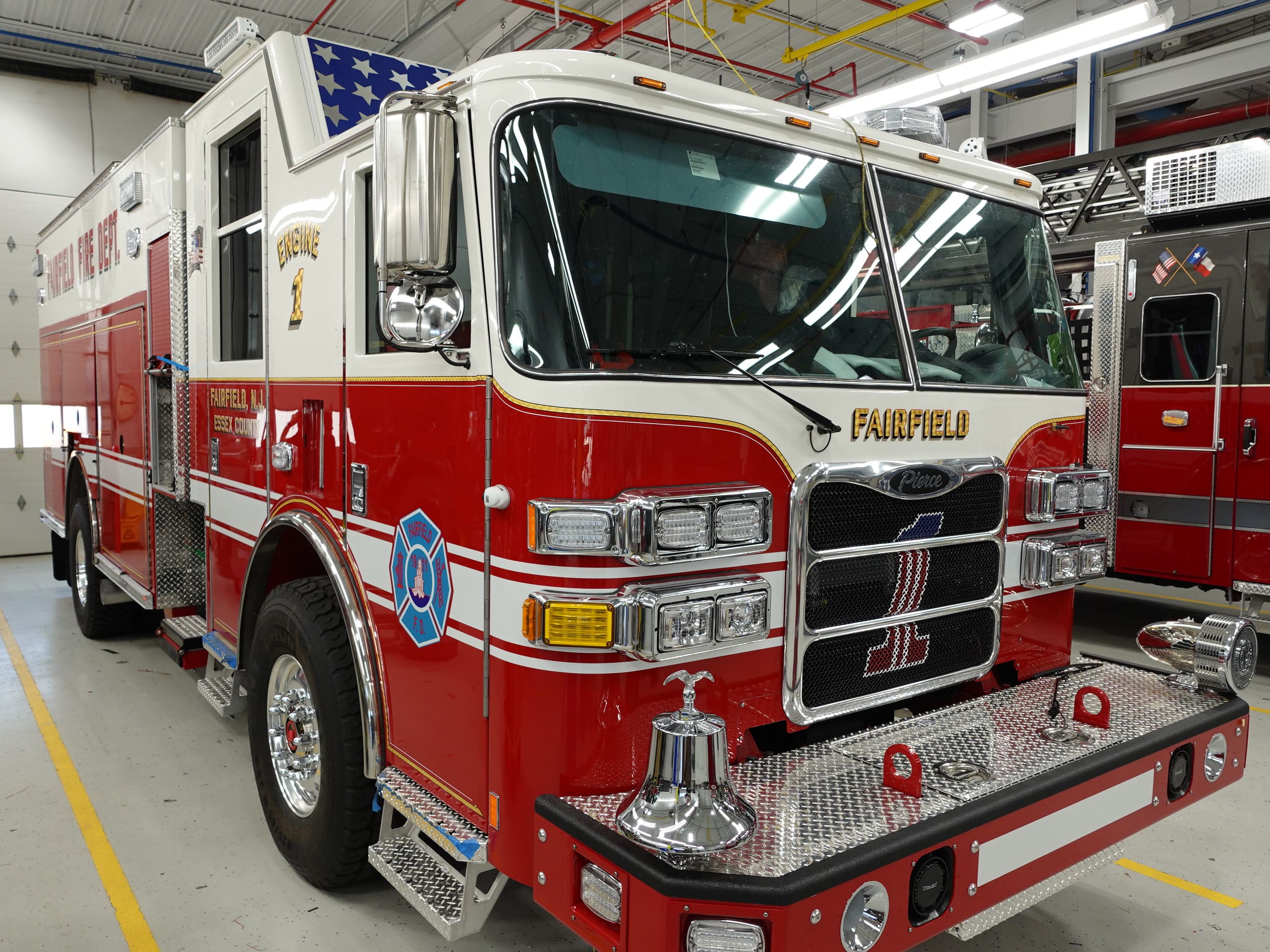

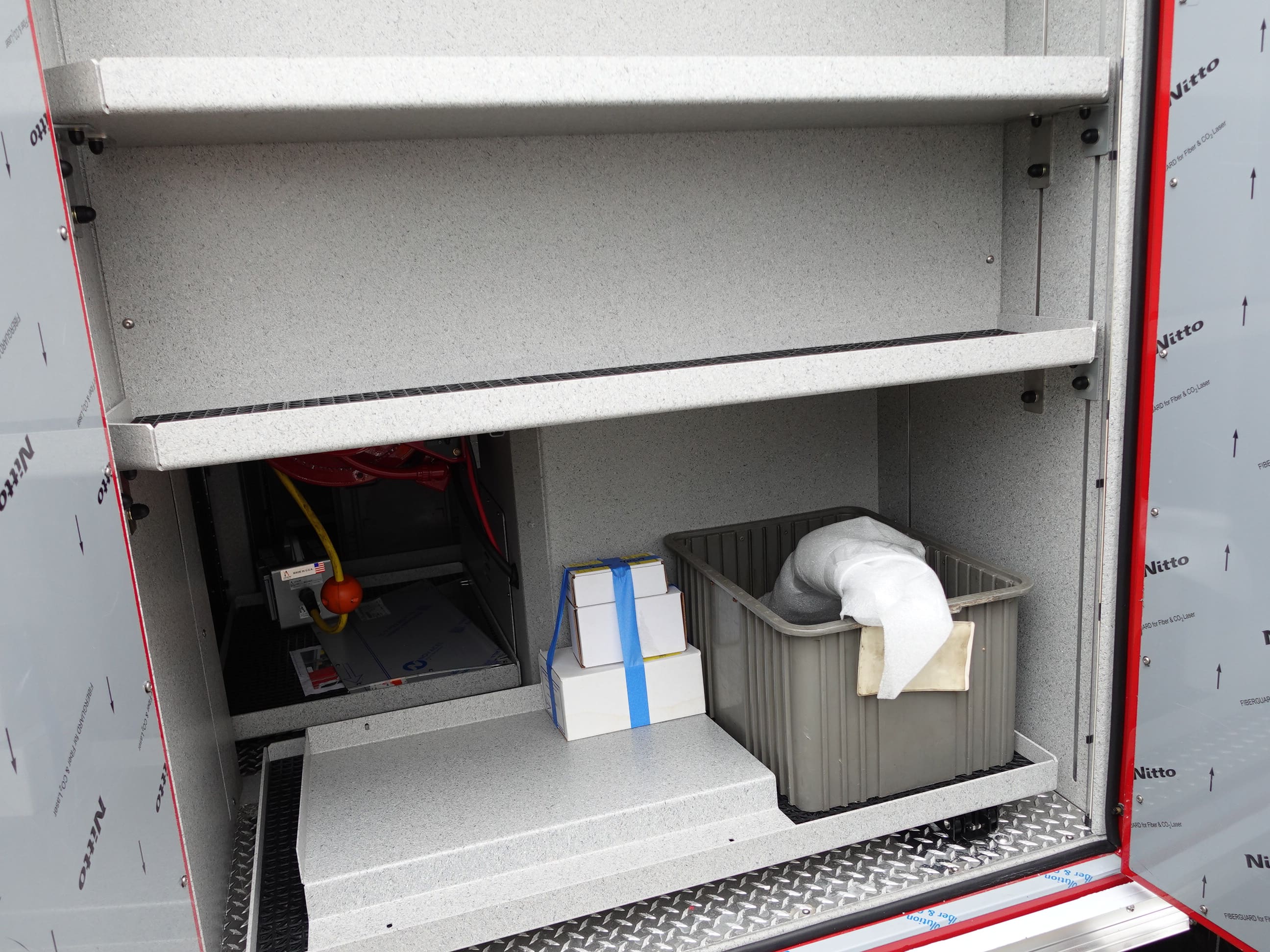

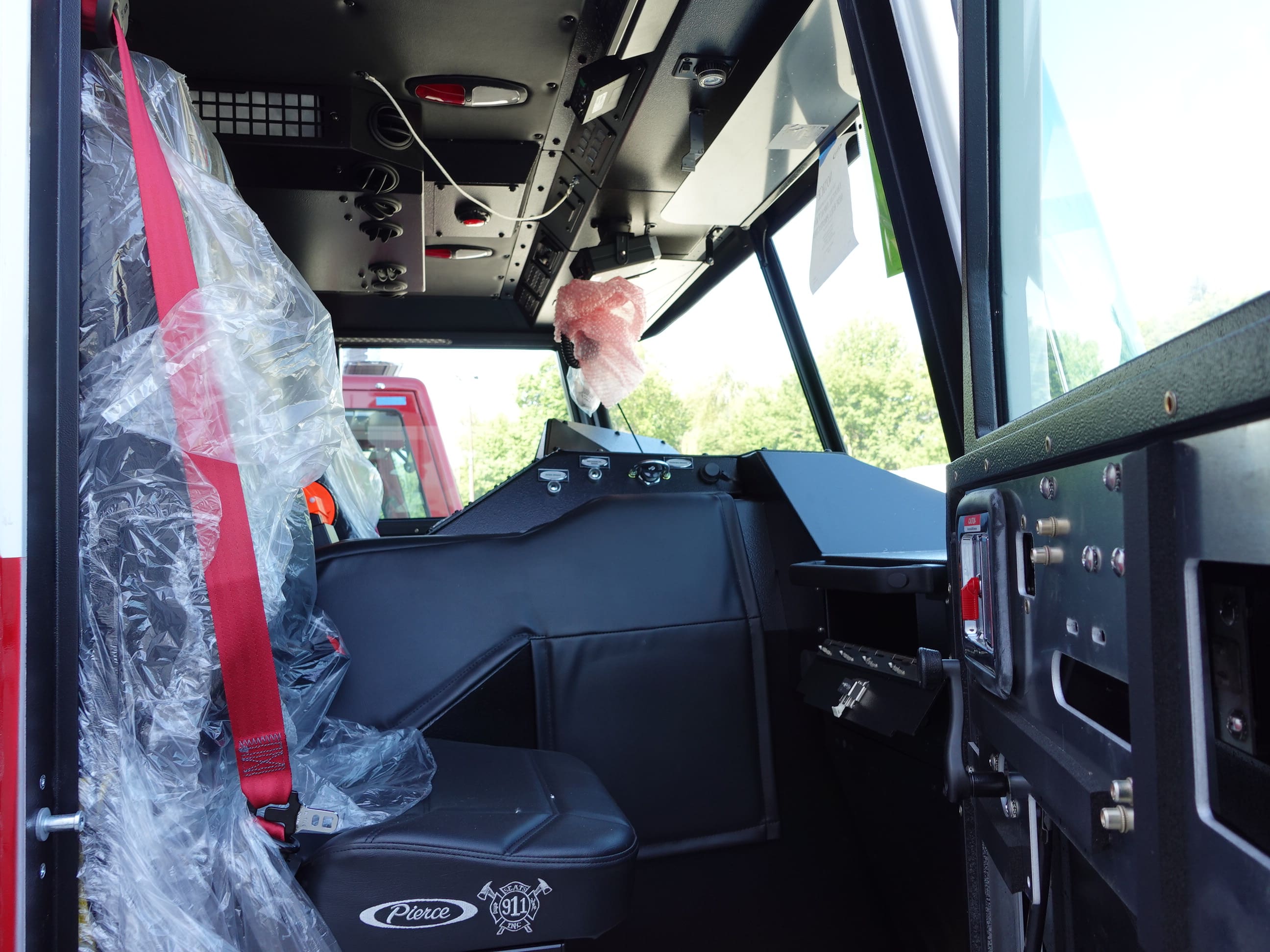

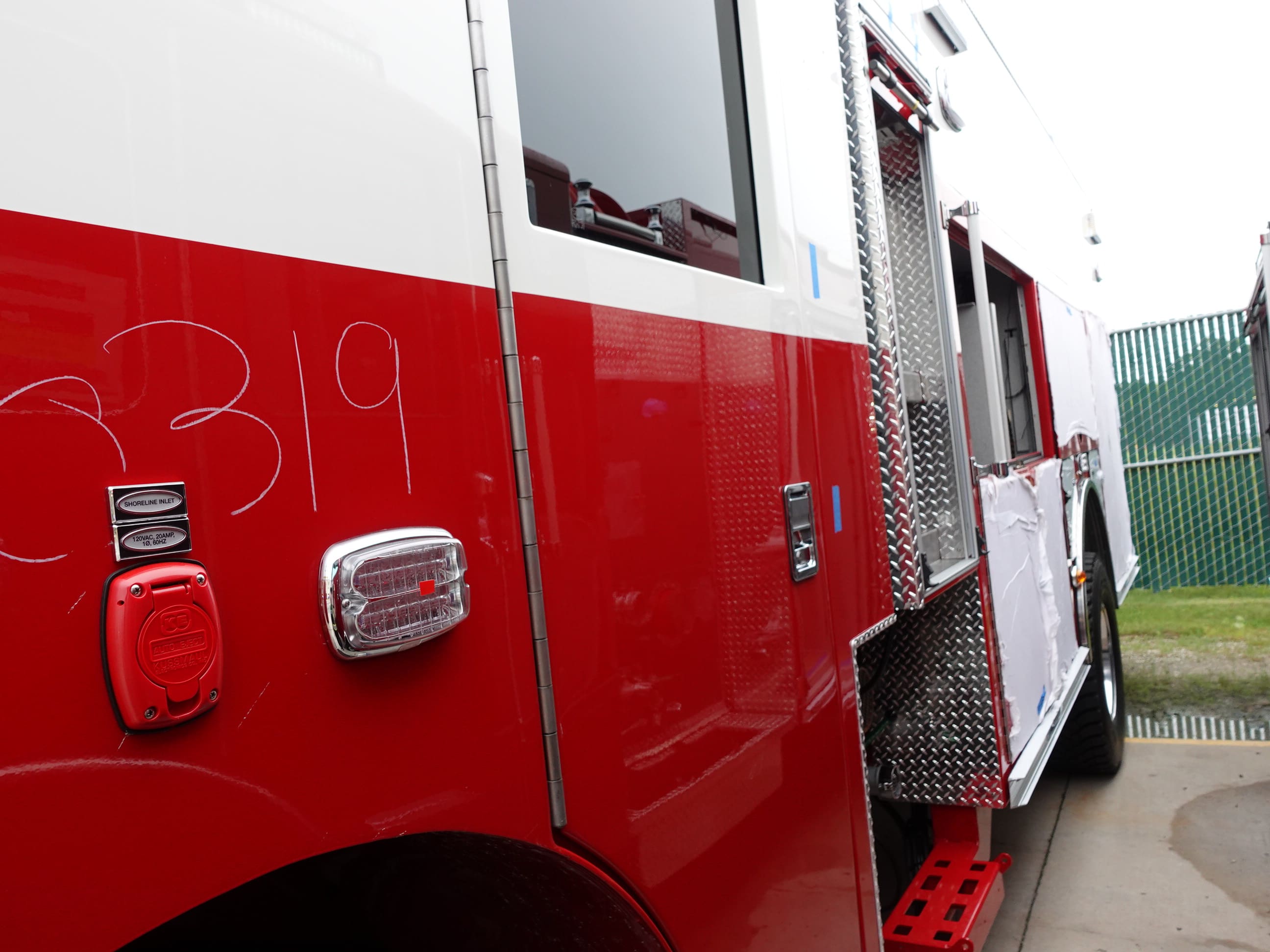

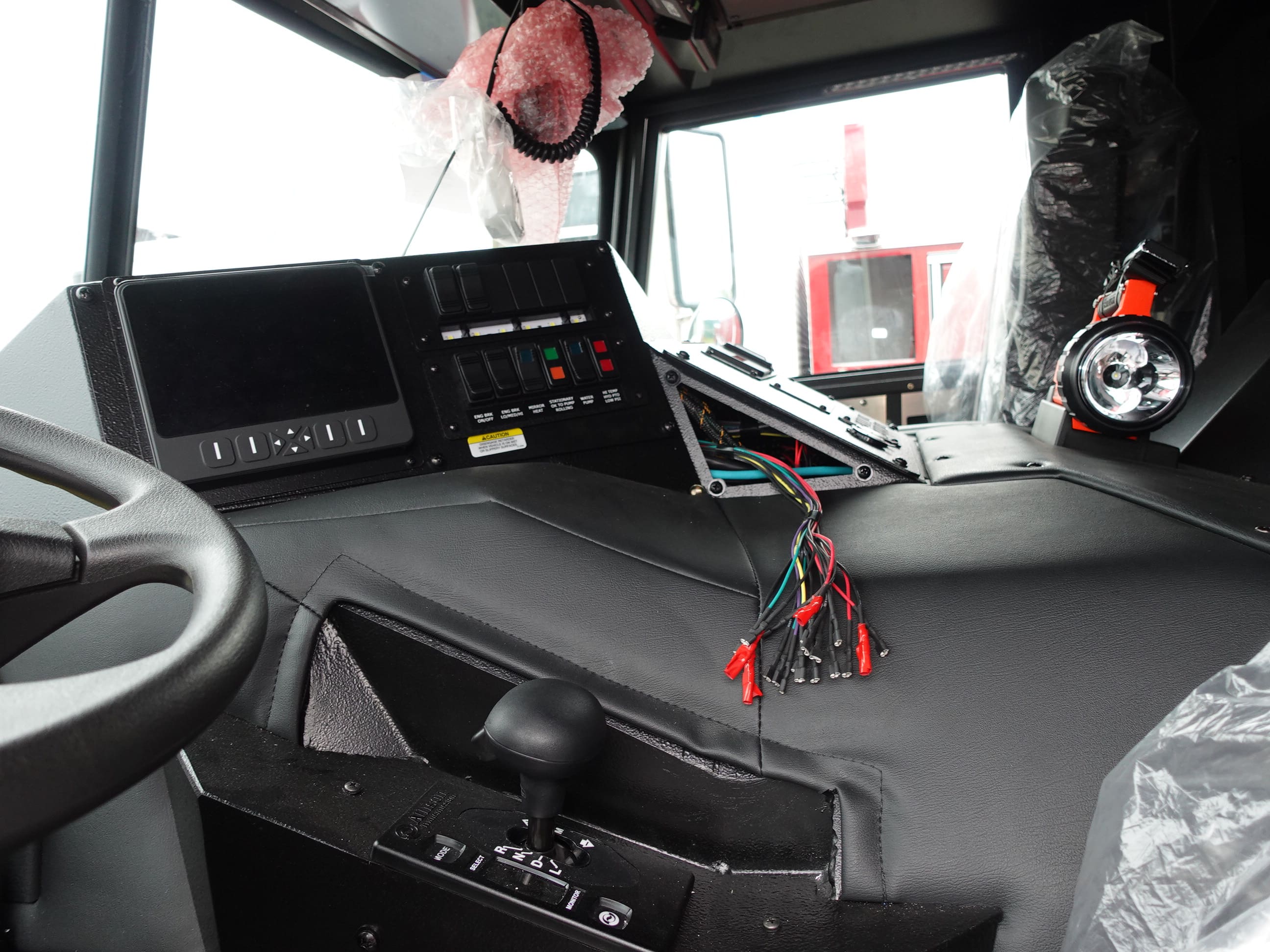

content will be applied. Once finished it will be made ready for the customer acceptance

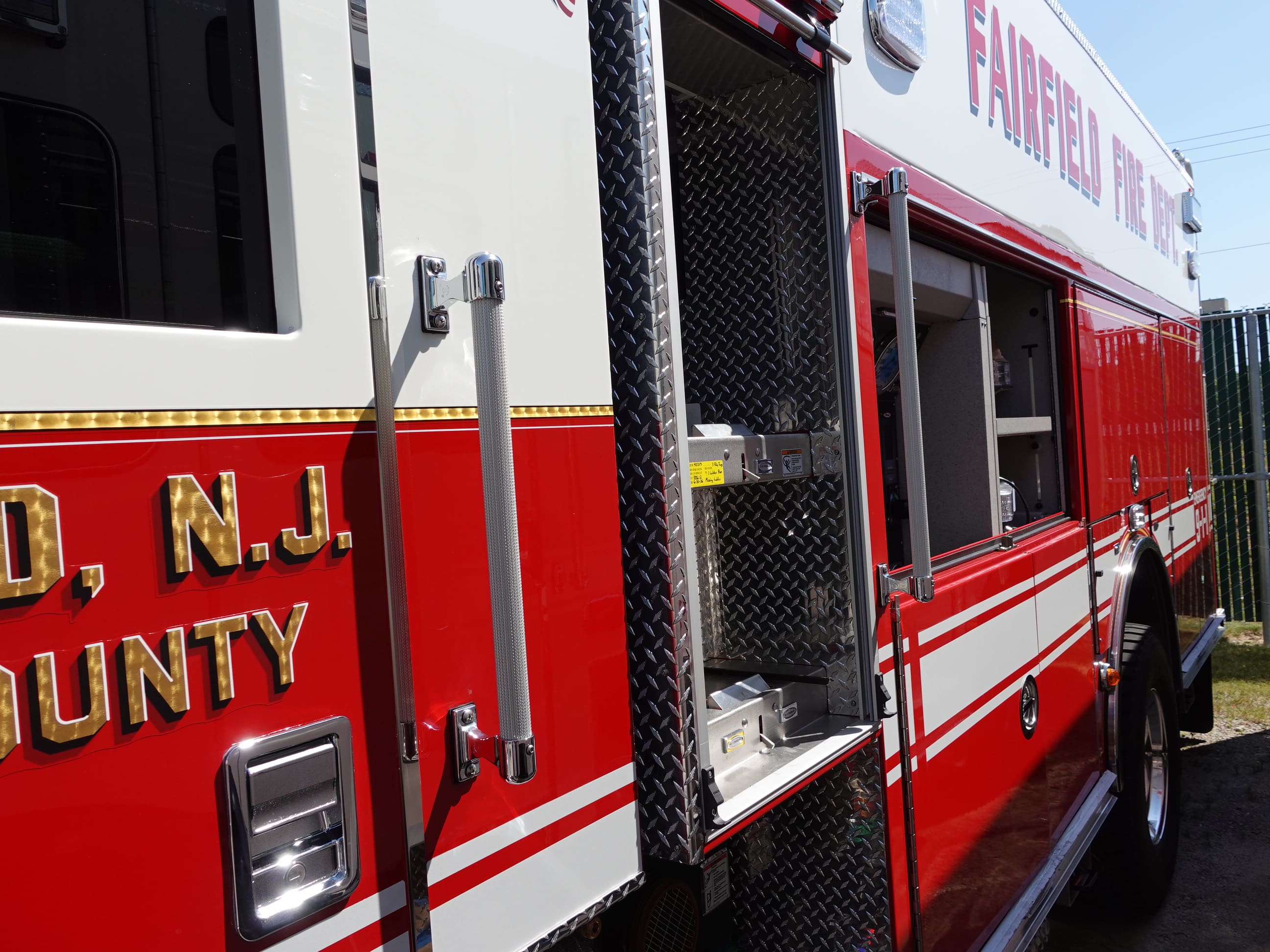

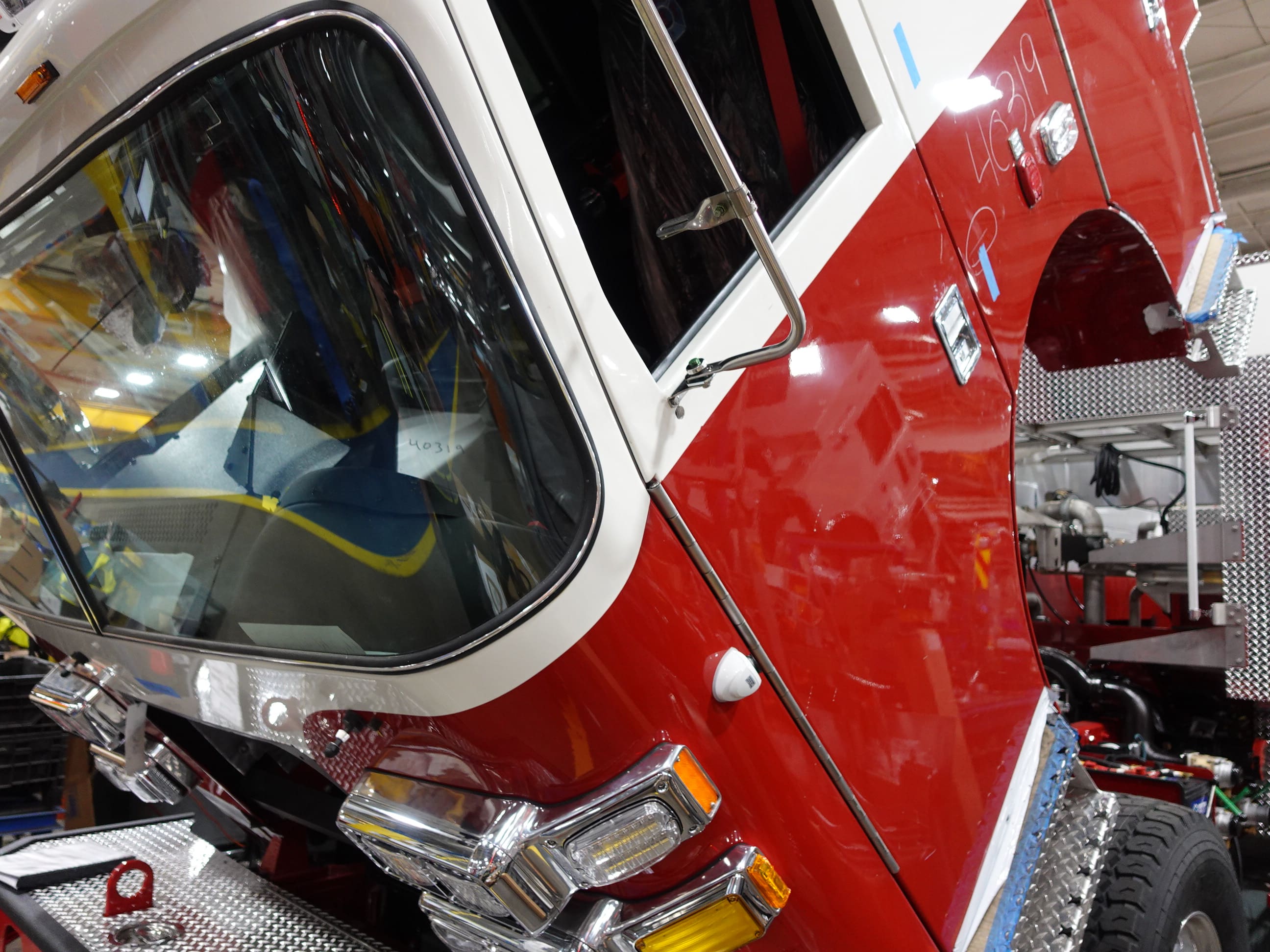

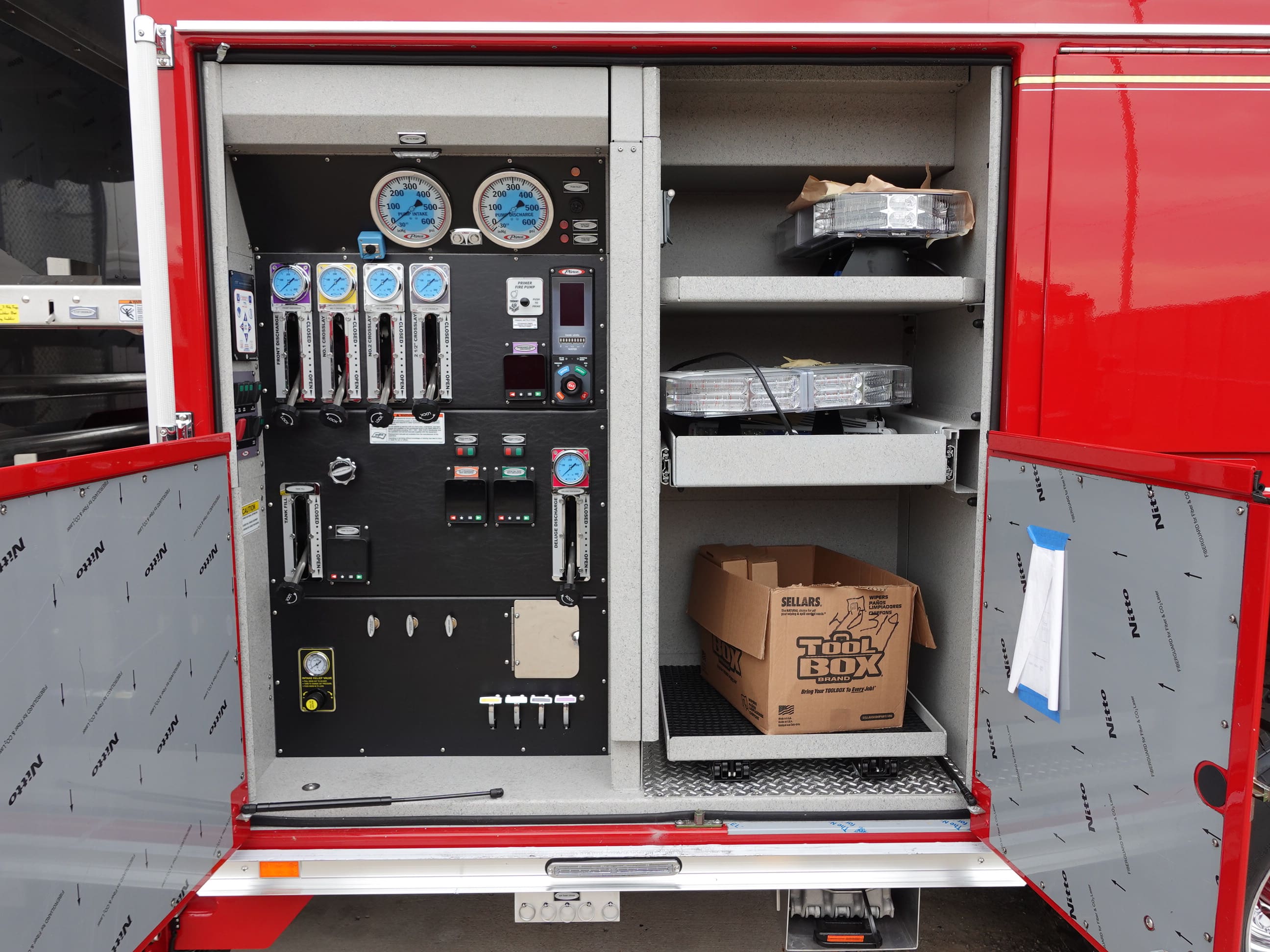

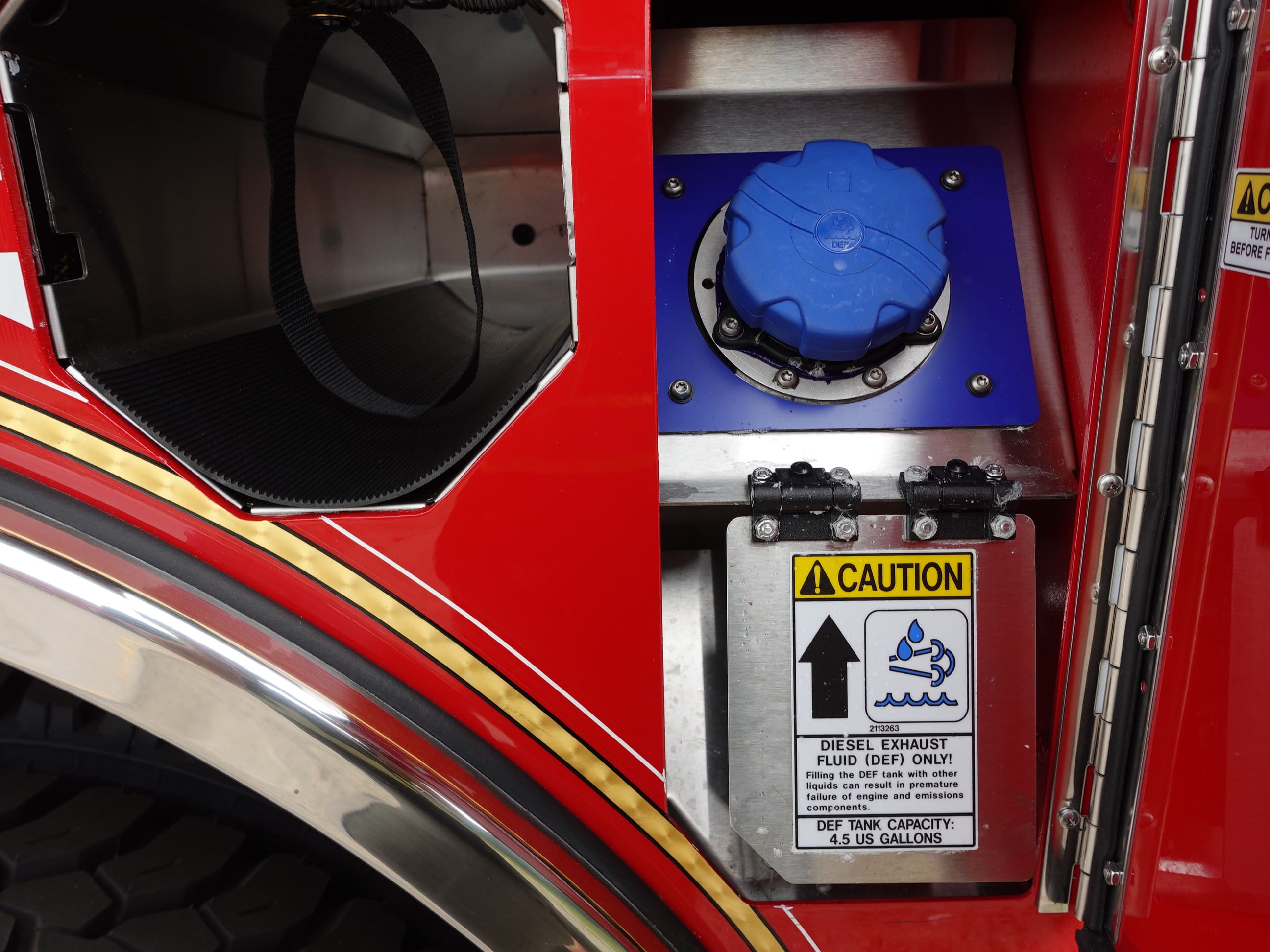

inspection. This is the last scheduled report.
07-17-26

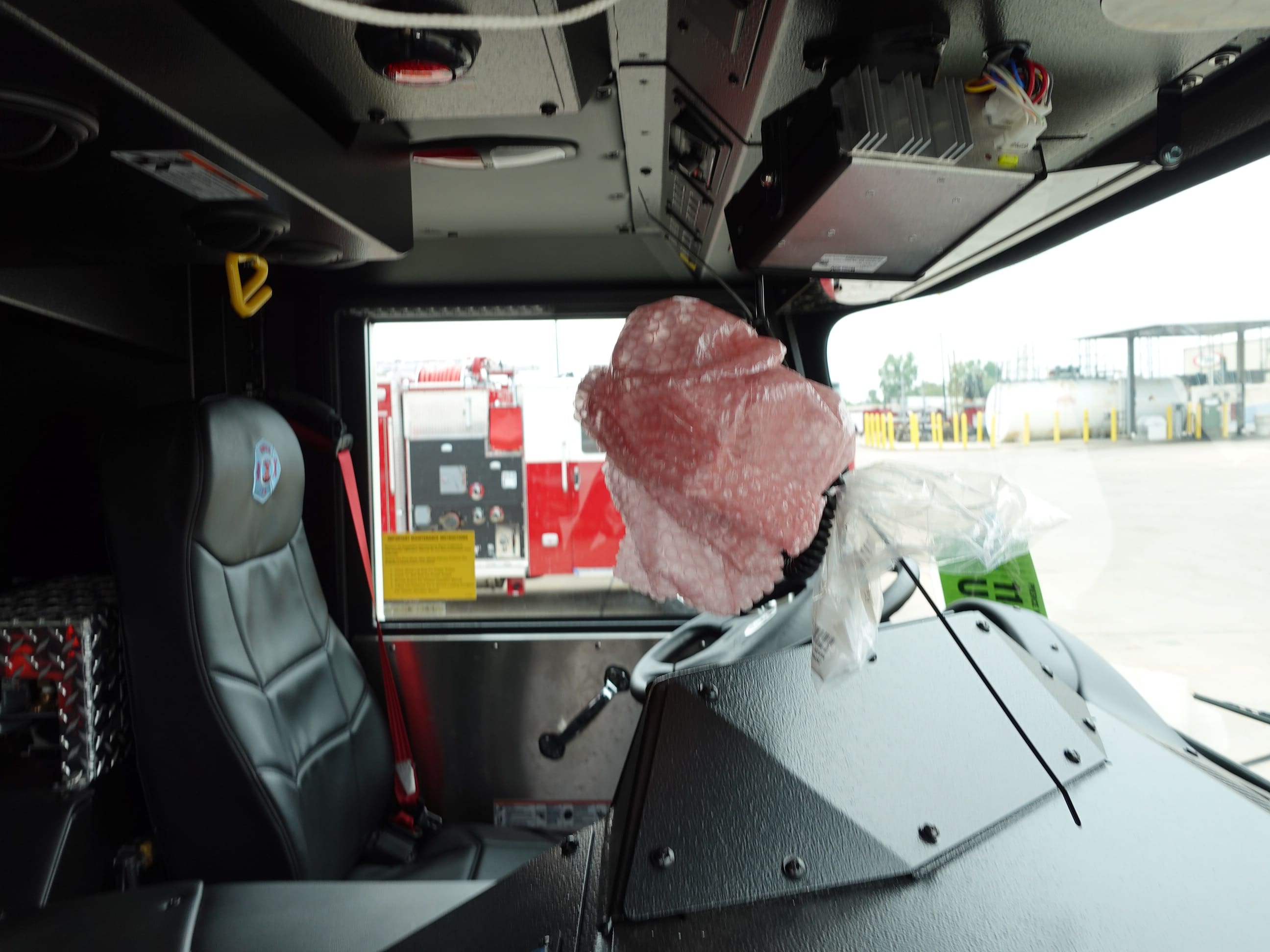

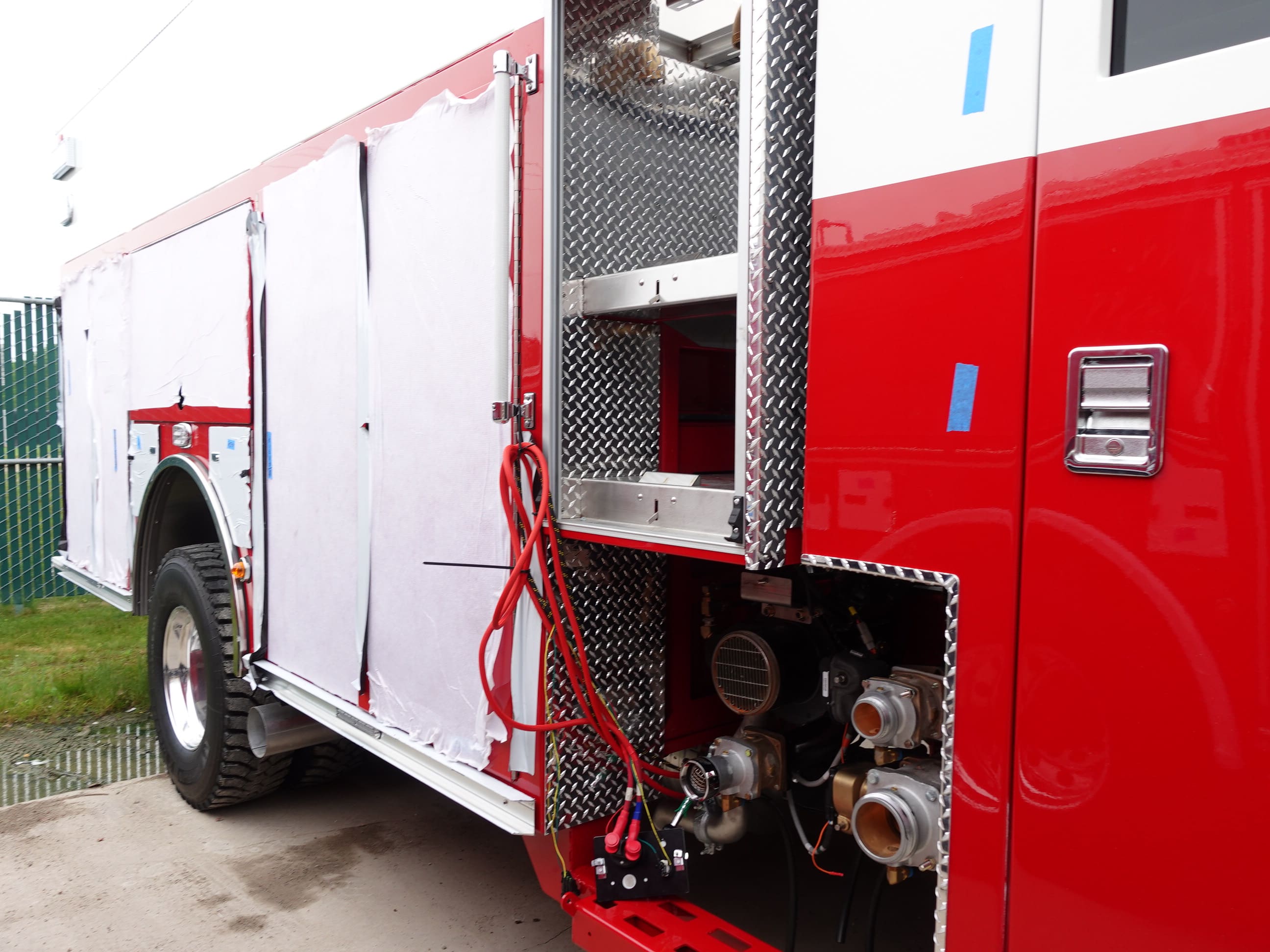

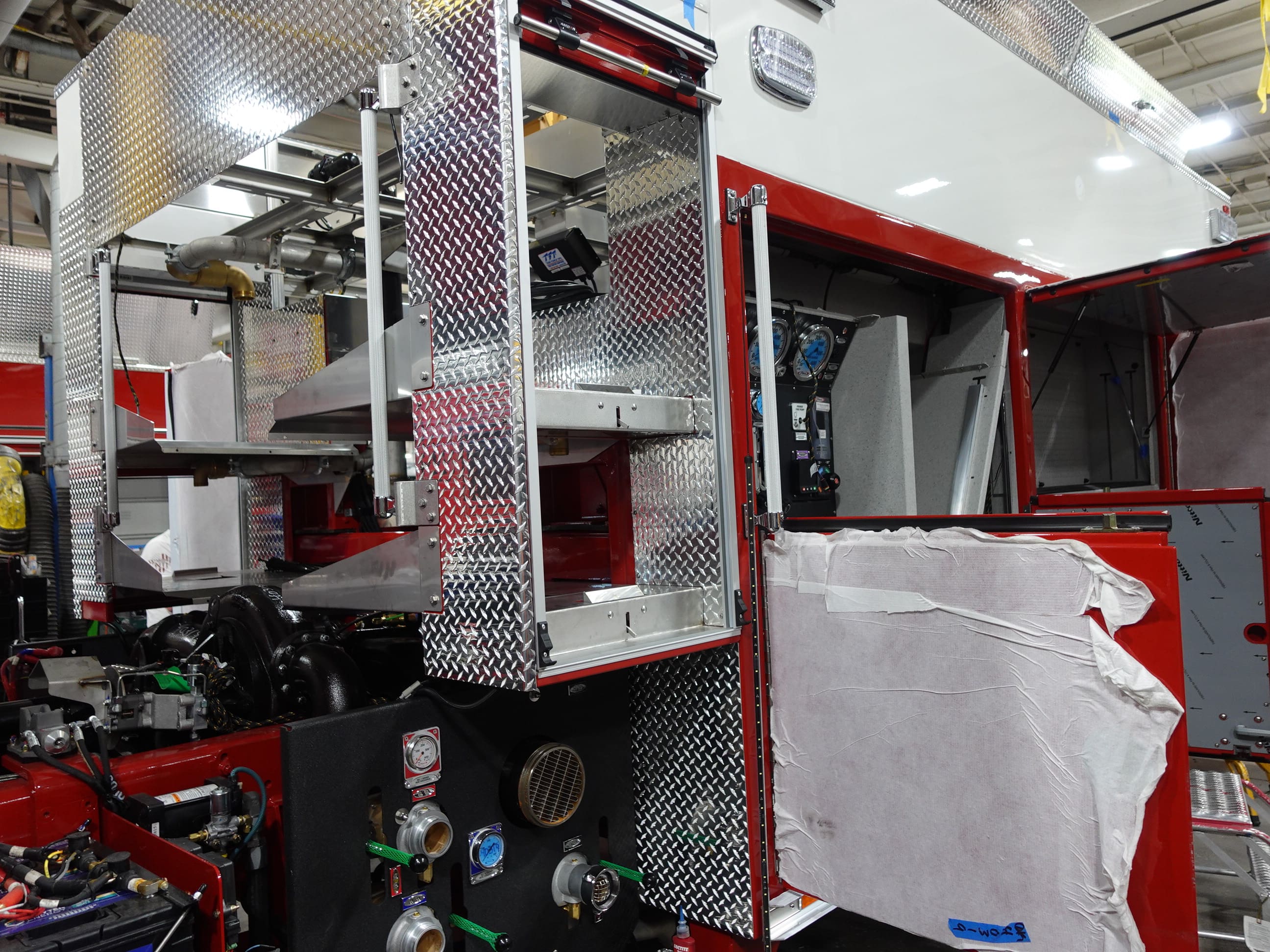

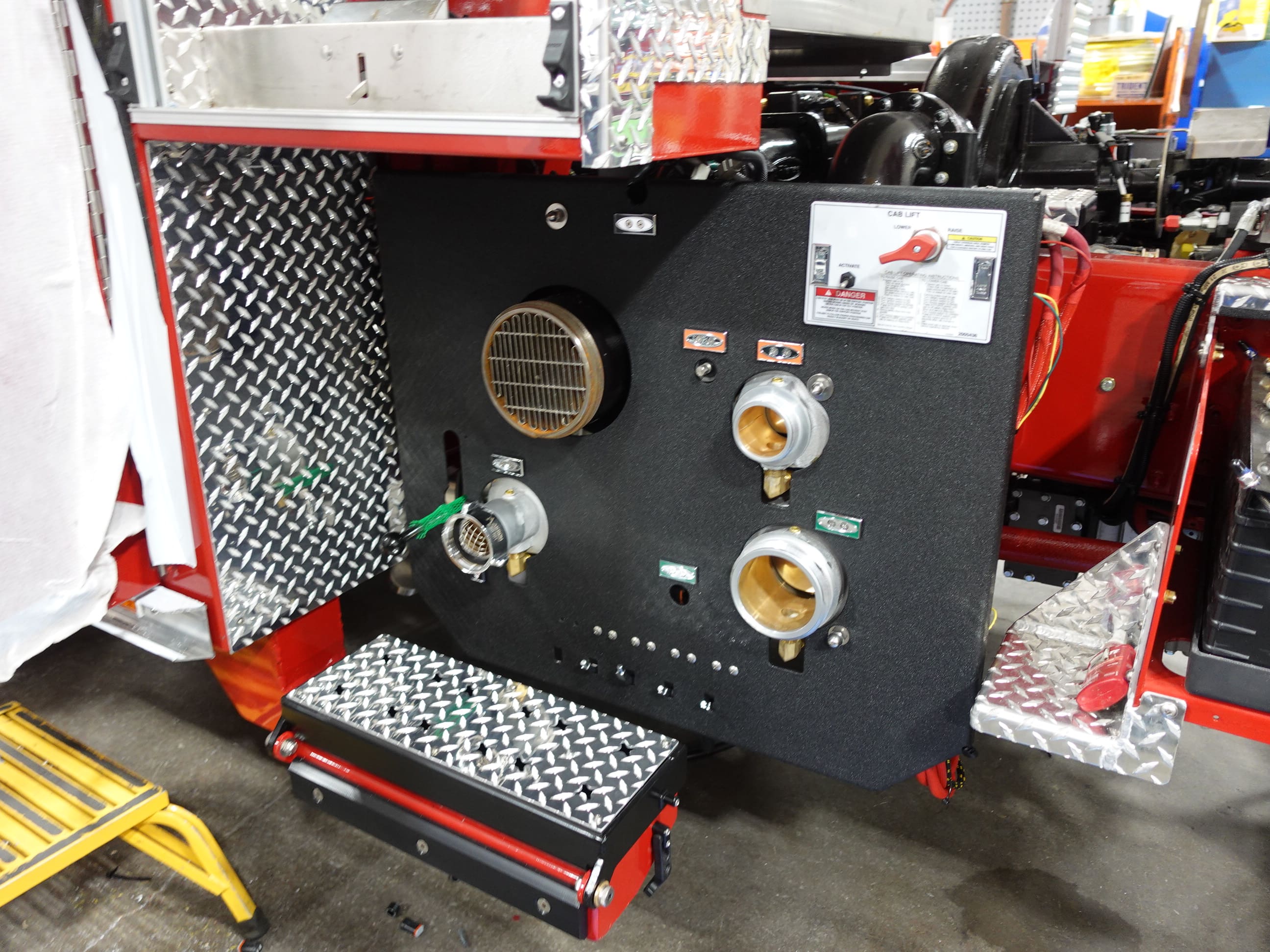

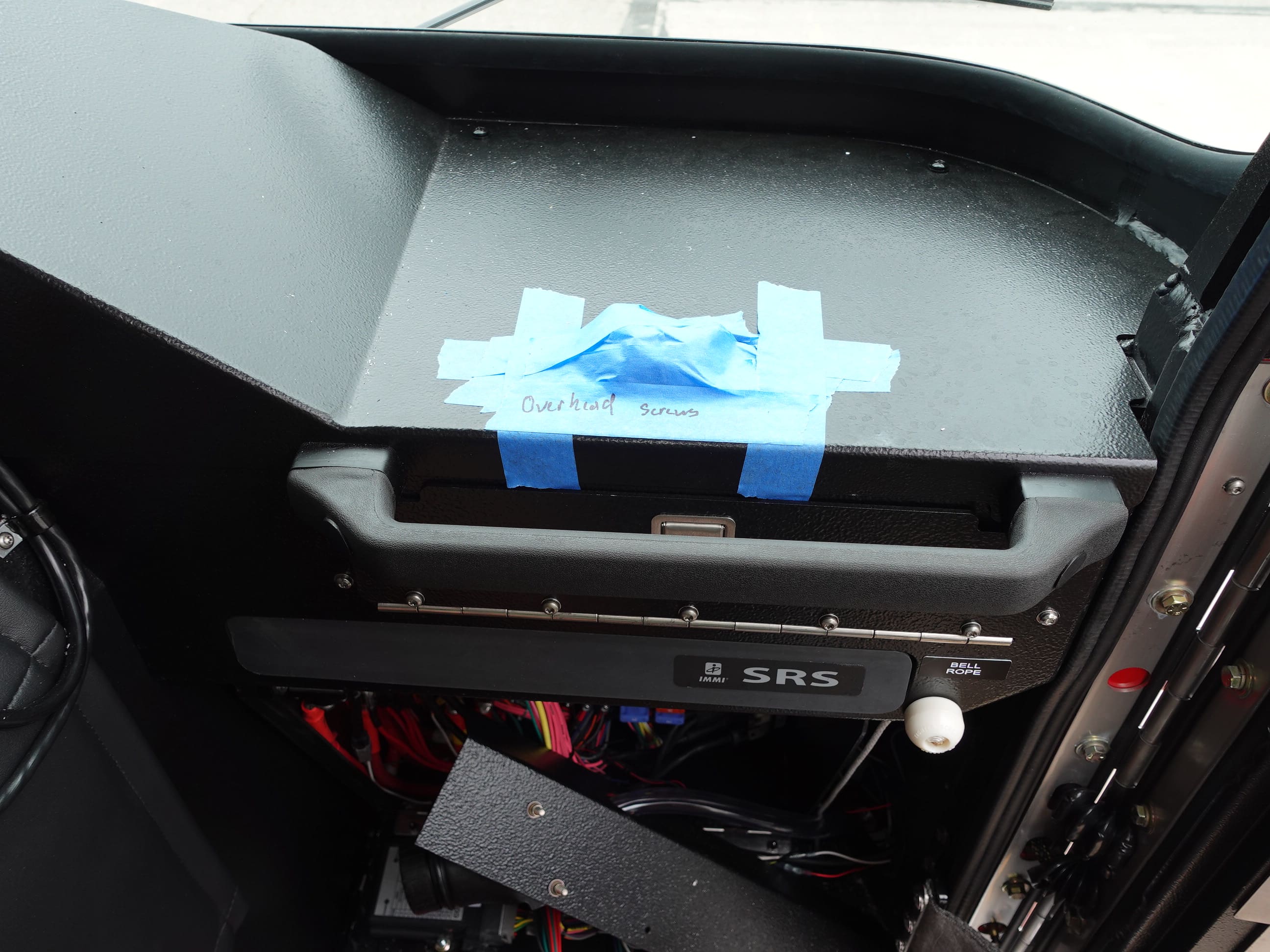

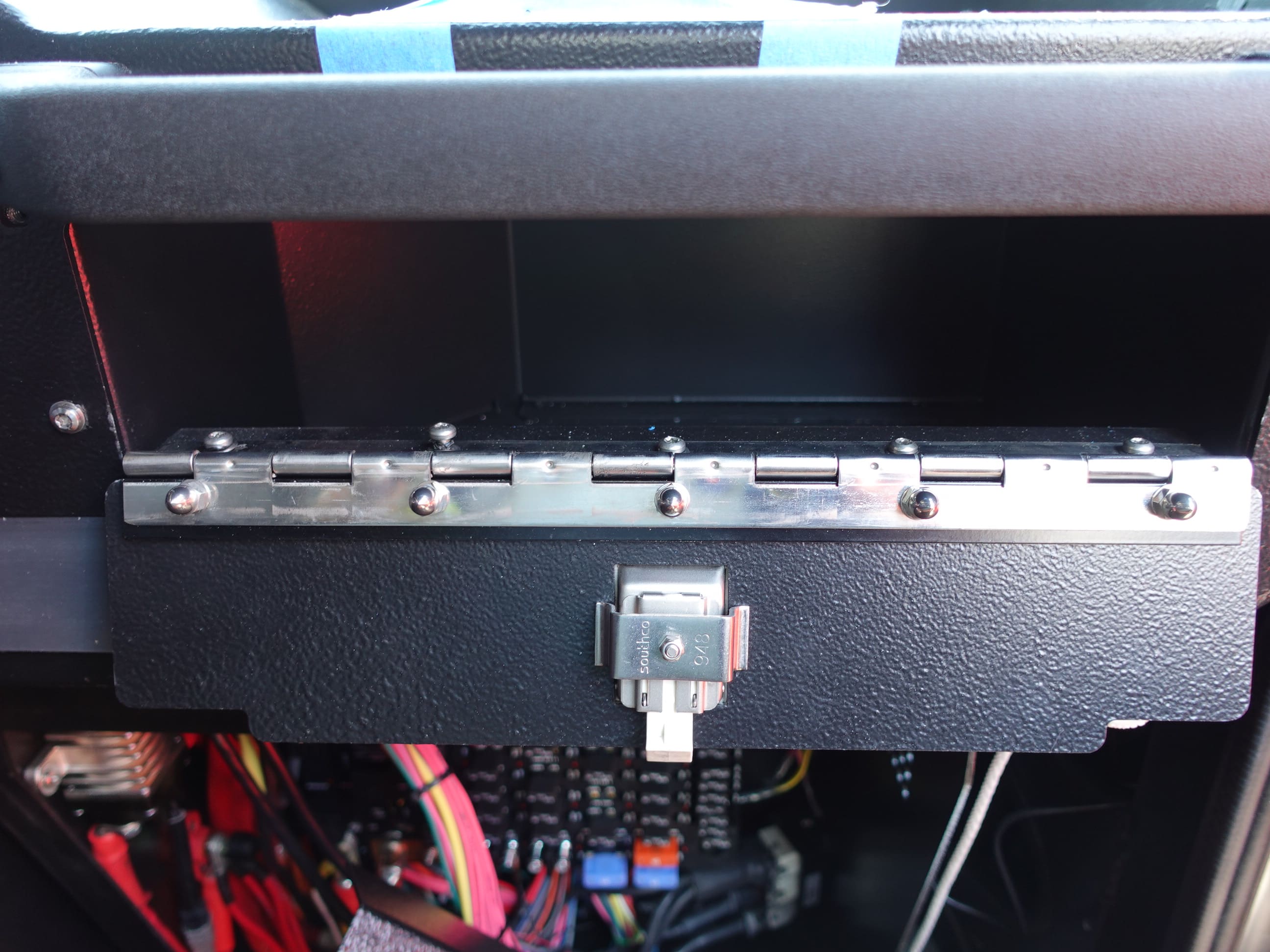

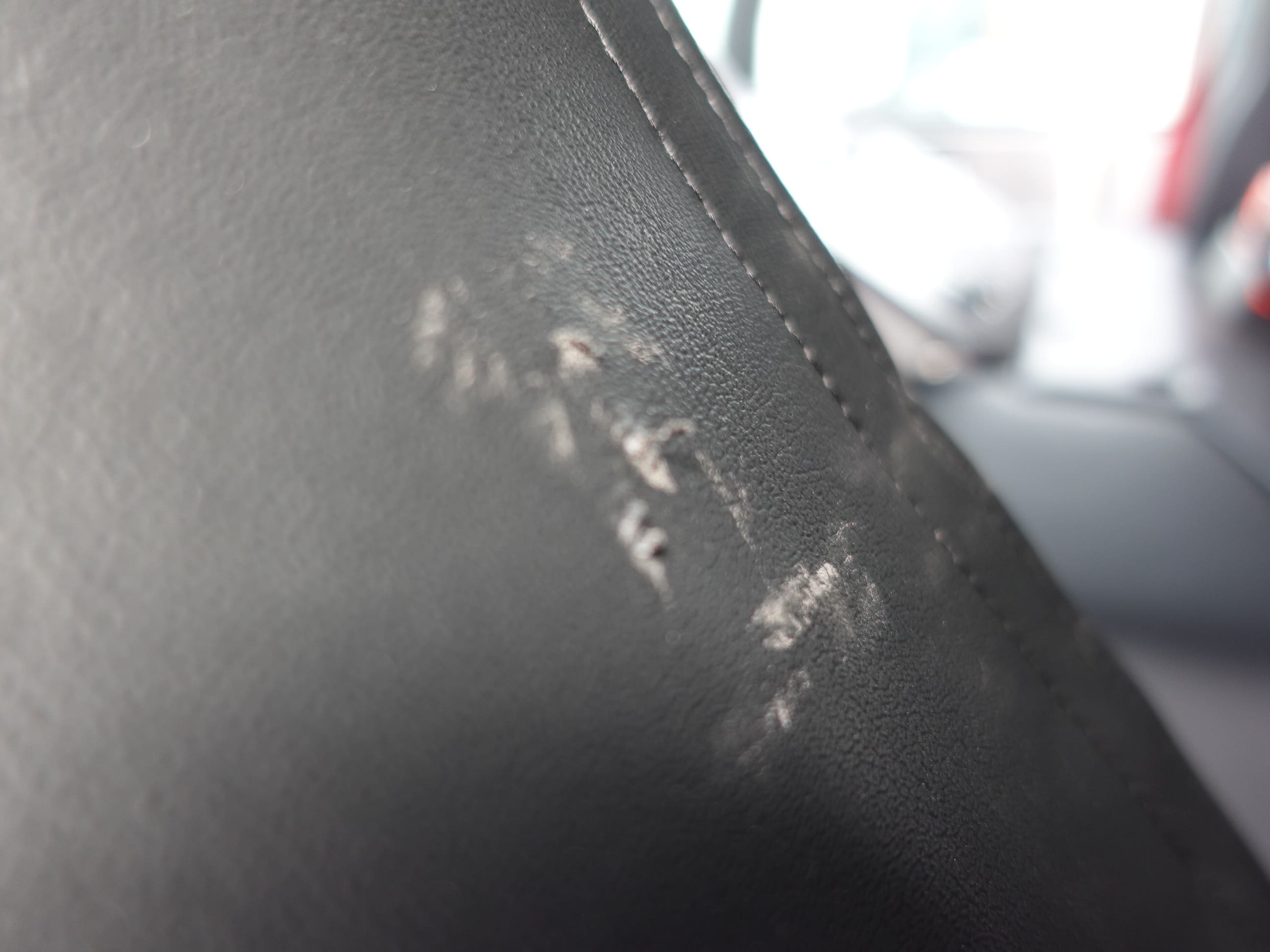

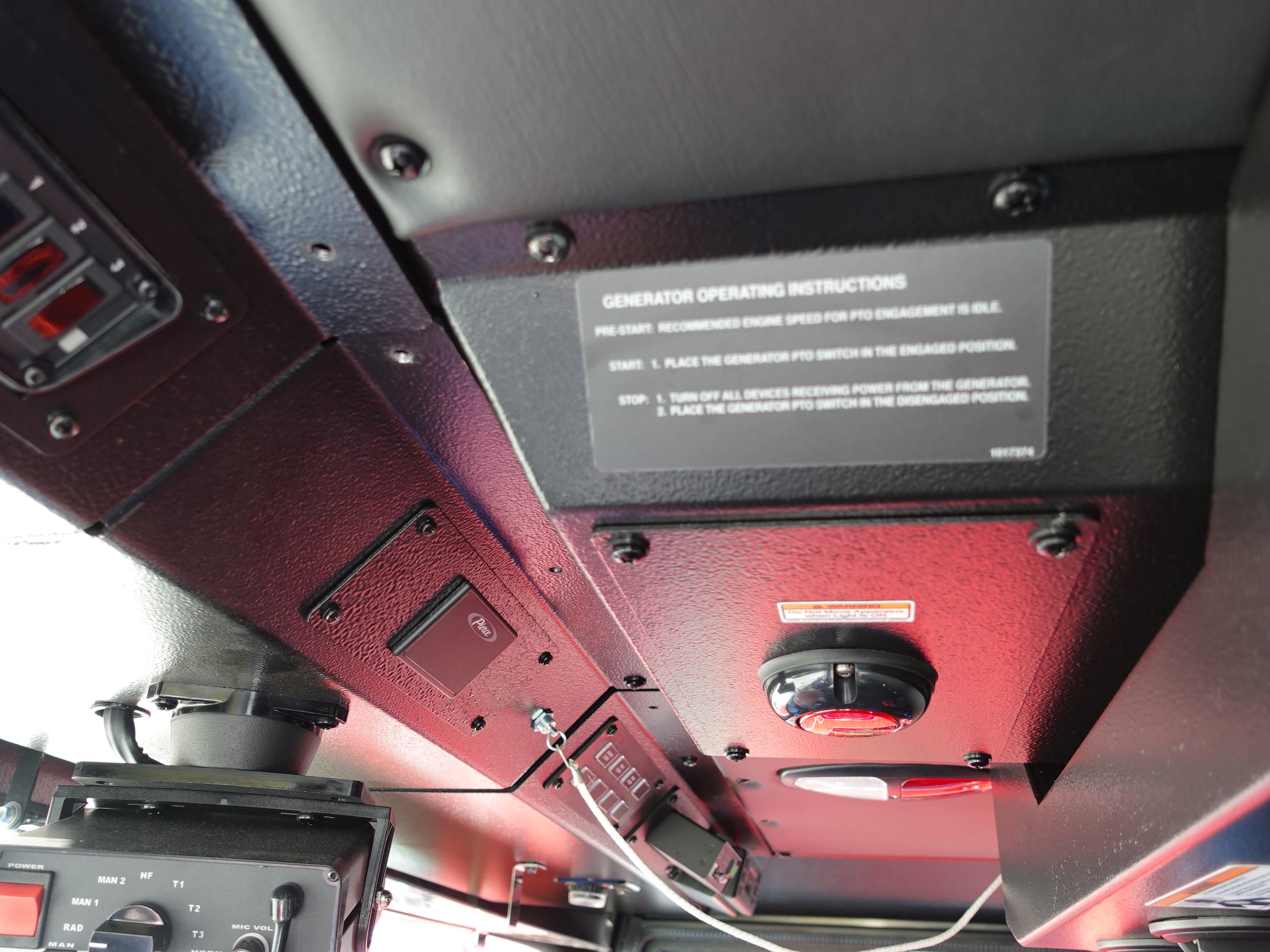

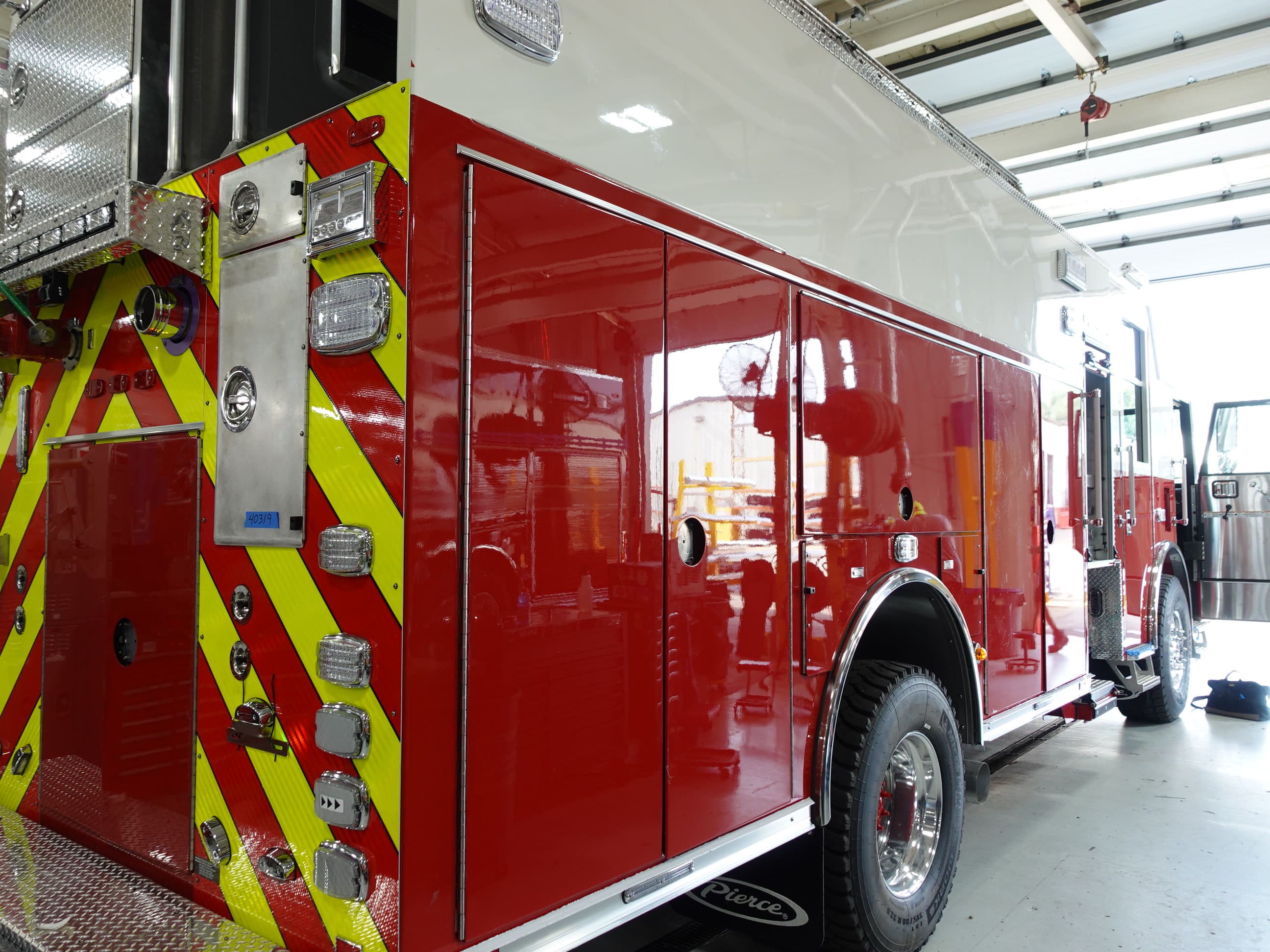

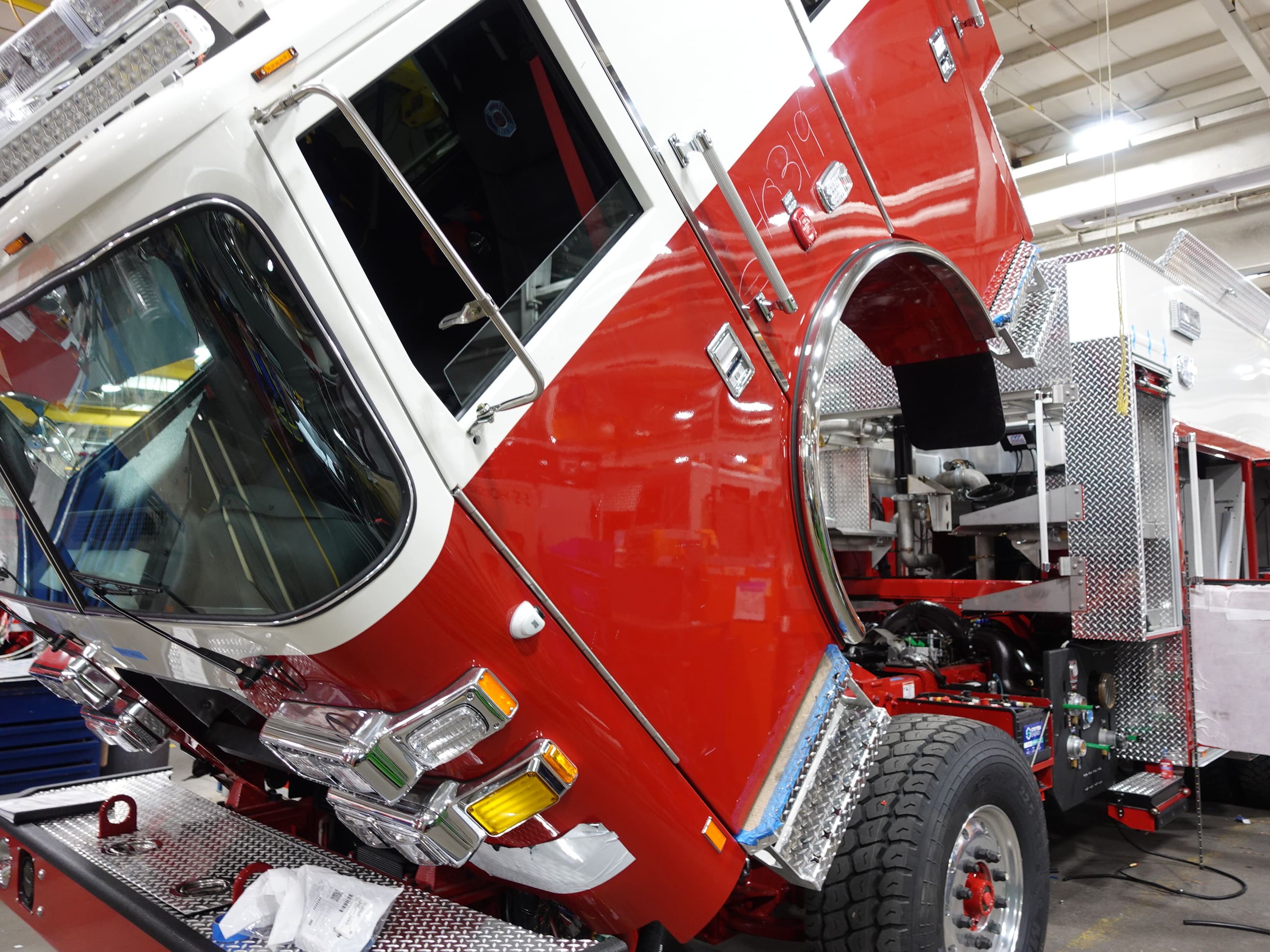

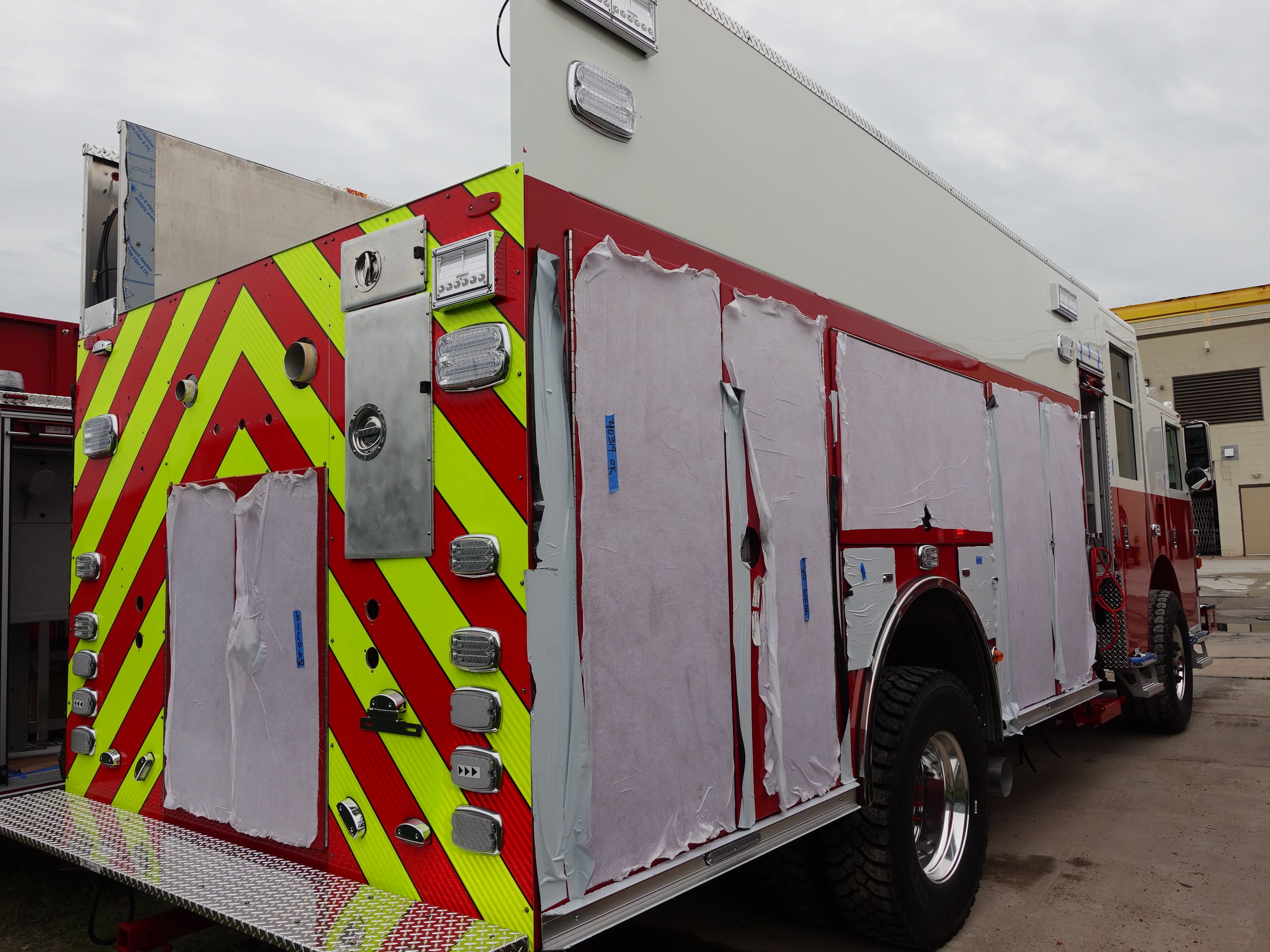

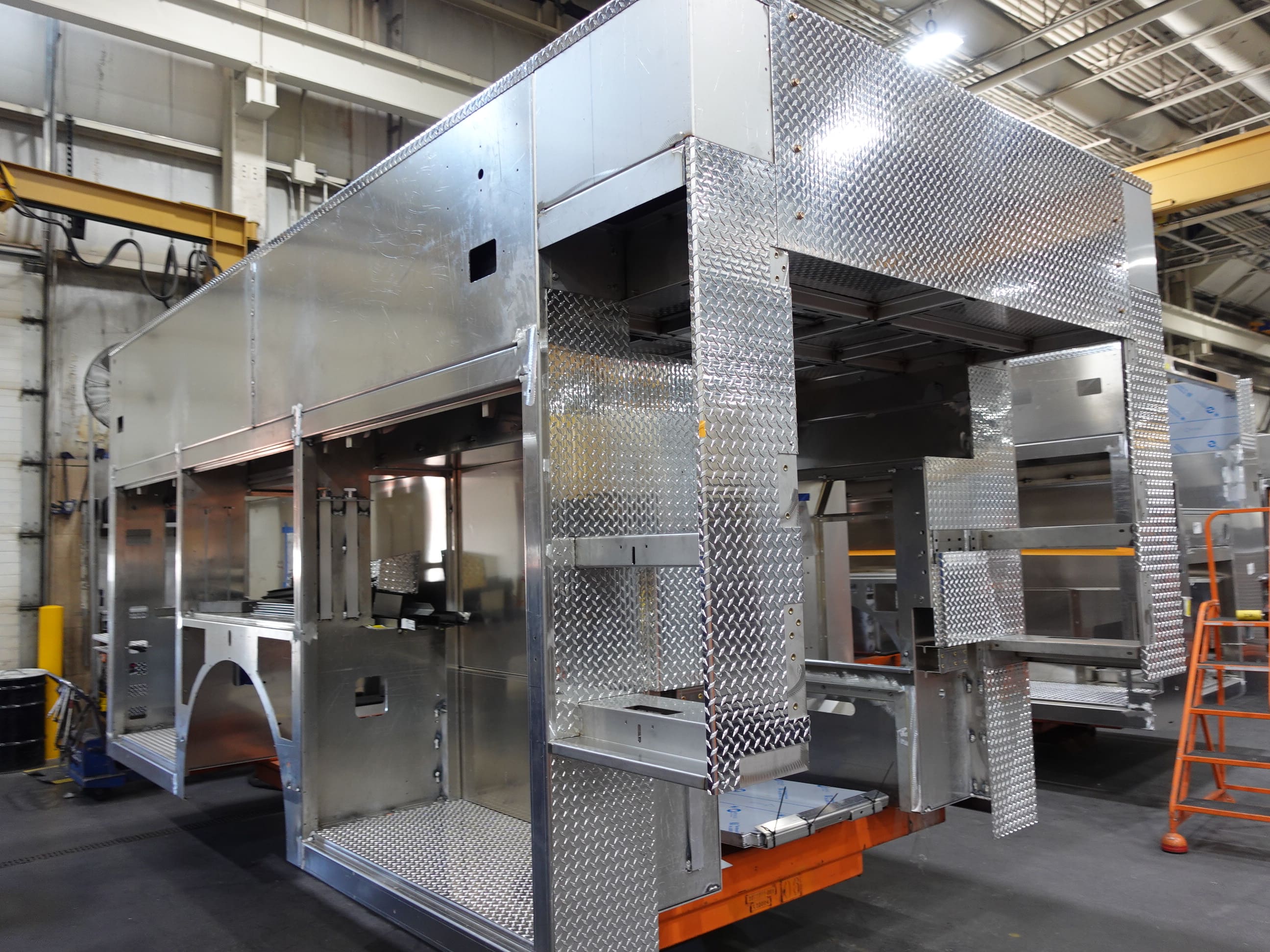

In this report, the apparatus completed test followed by release to quality and graphics where any remaining content will be applied.

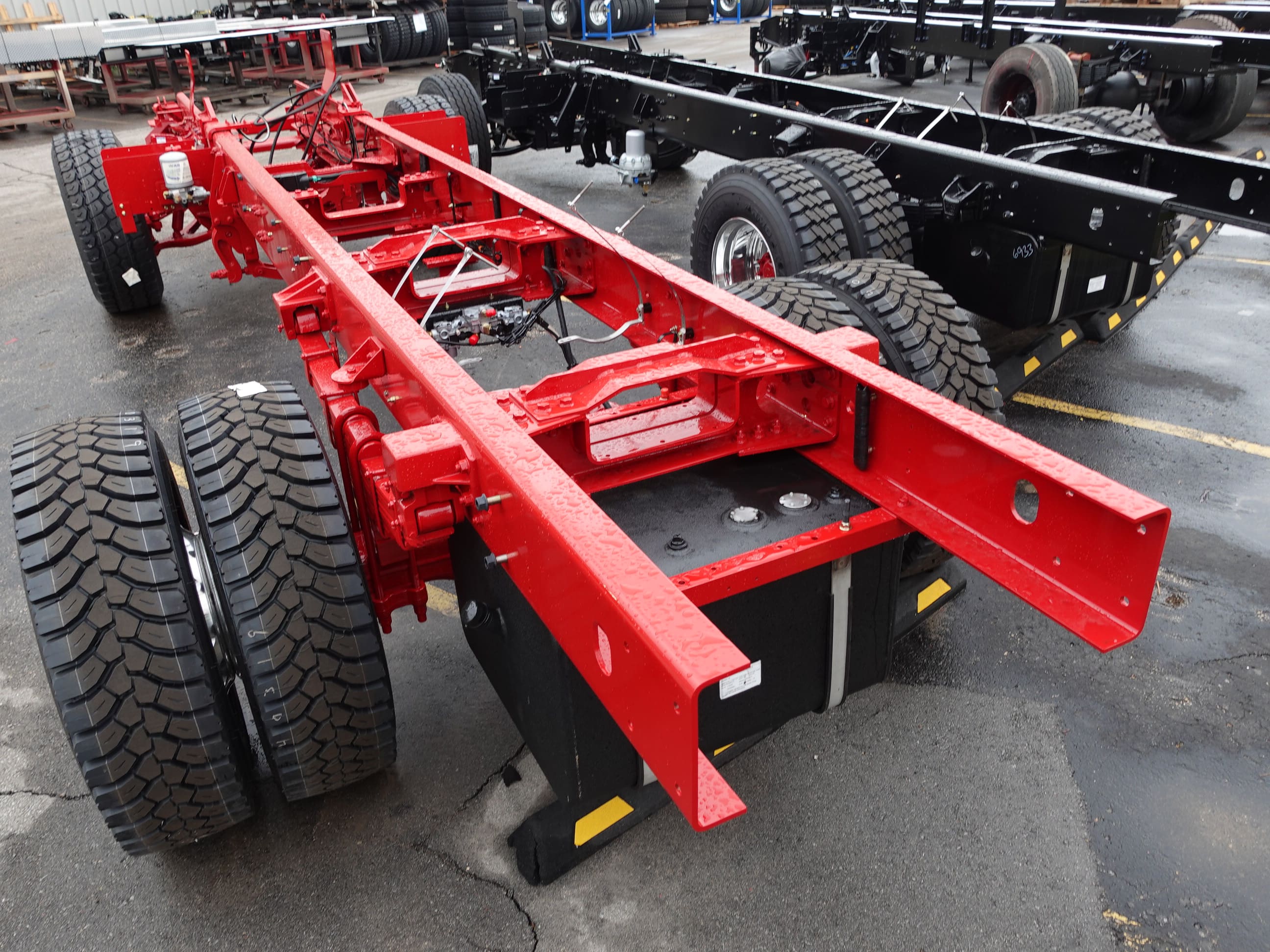

06-12-26

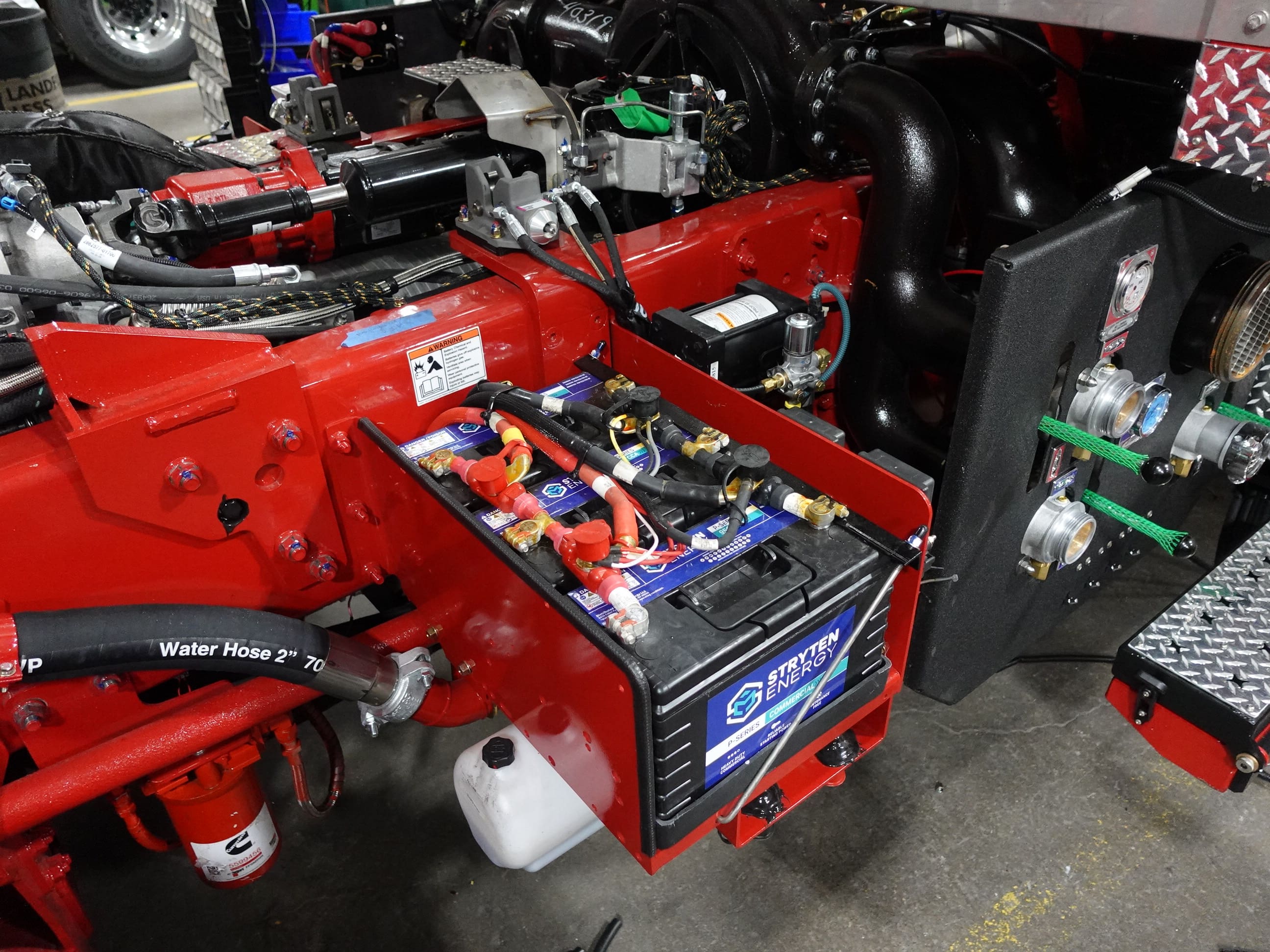

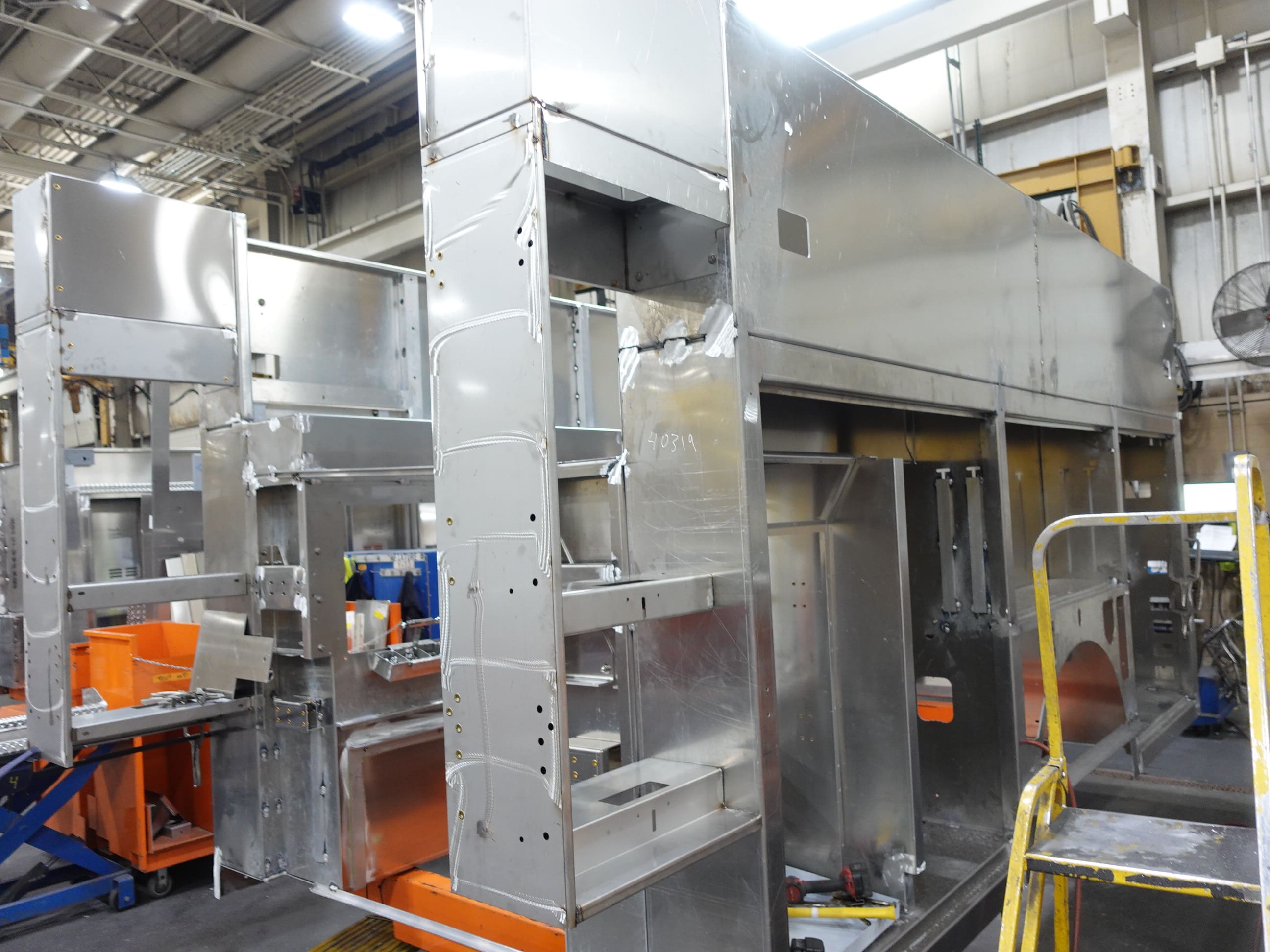

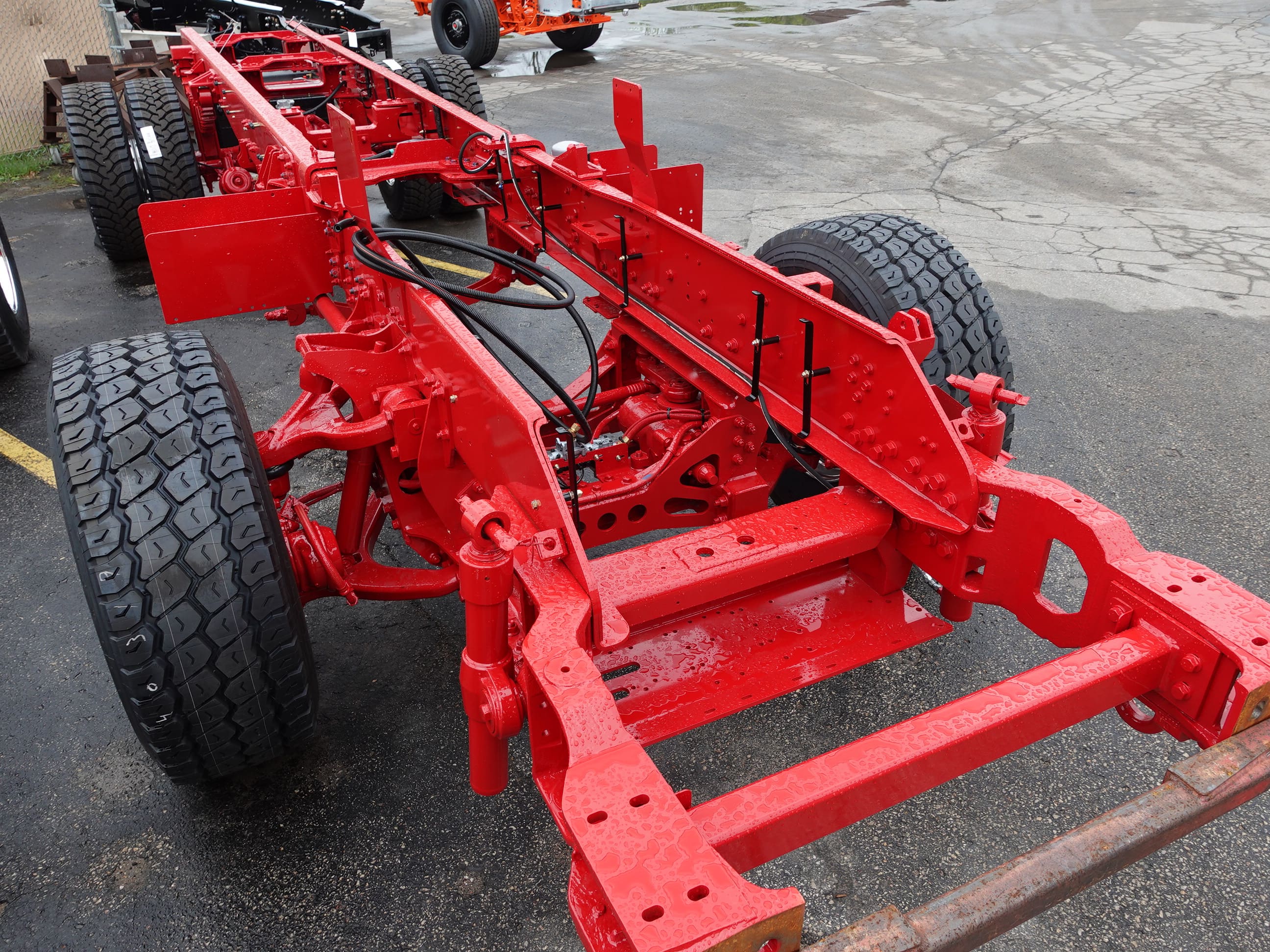

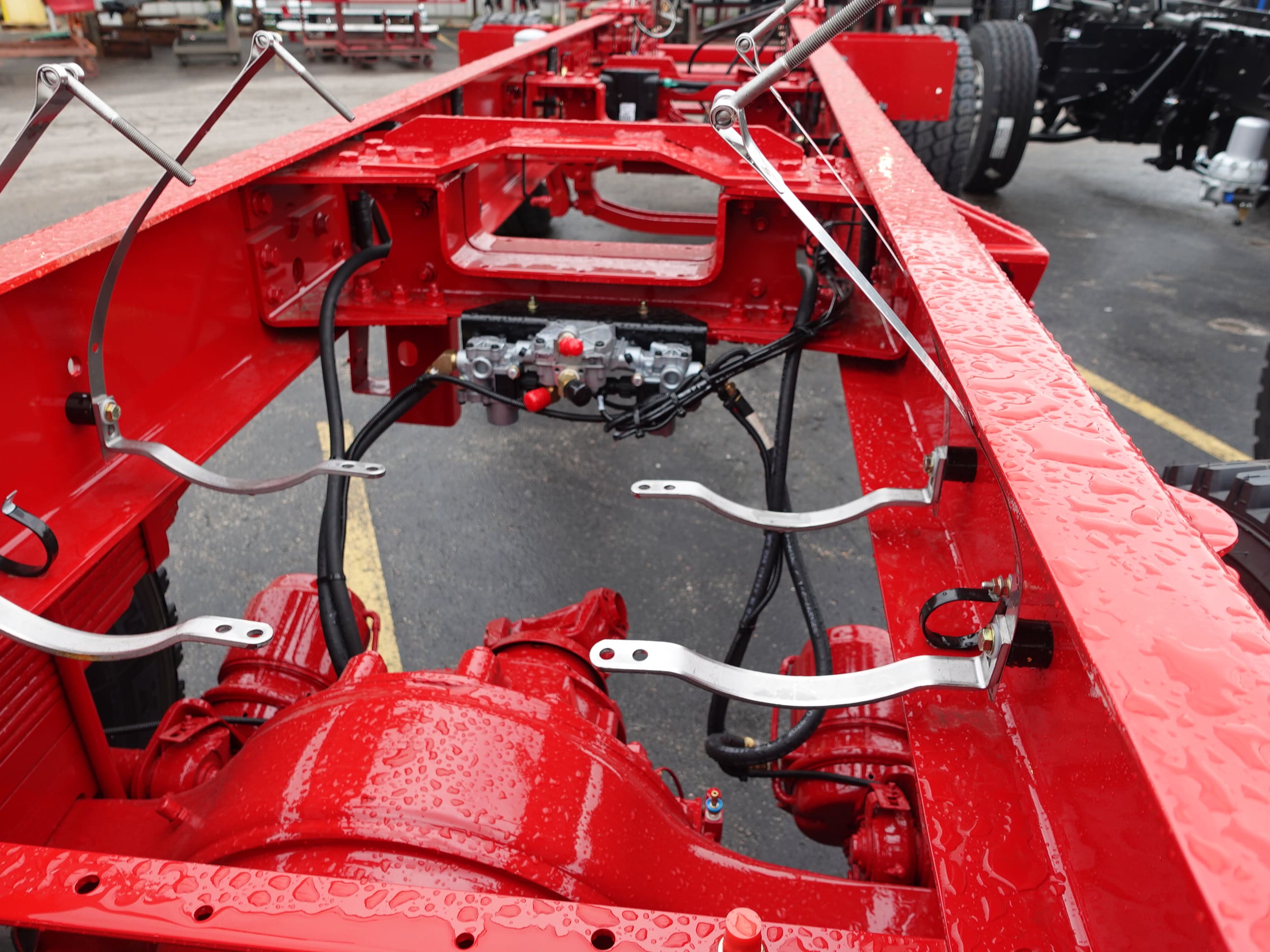

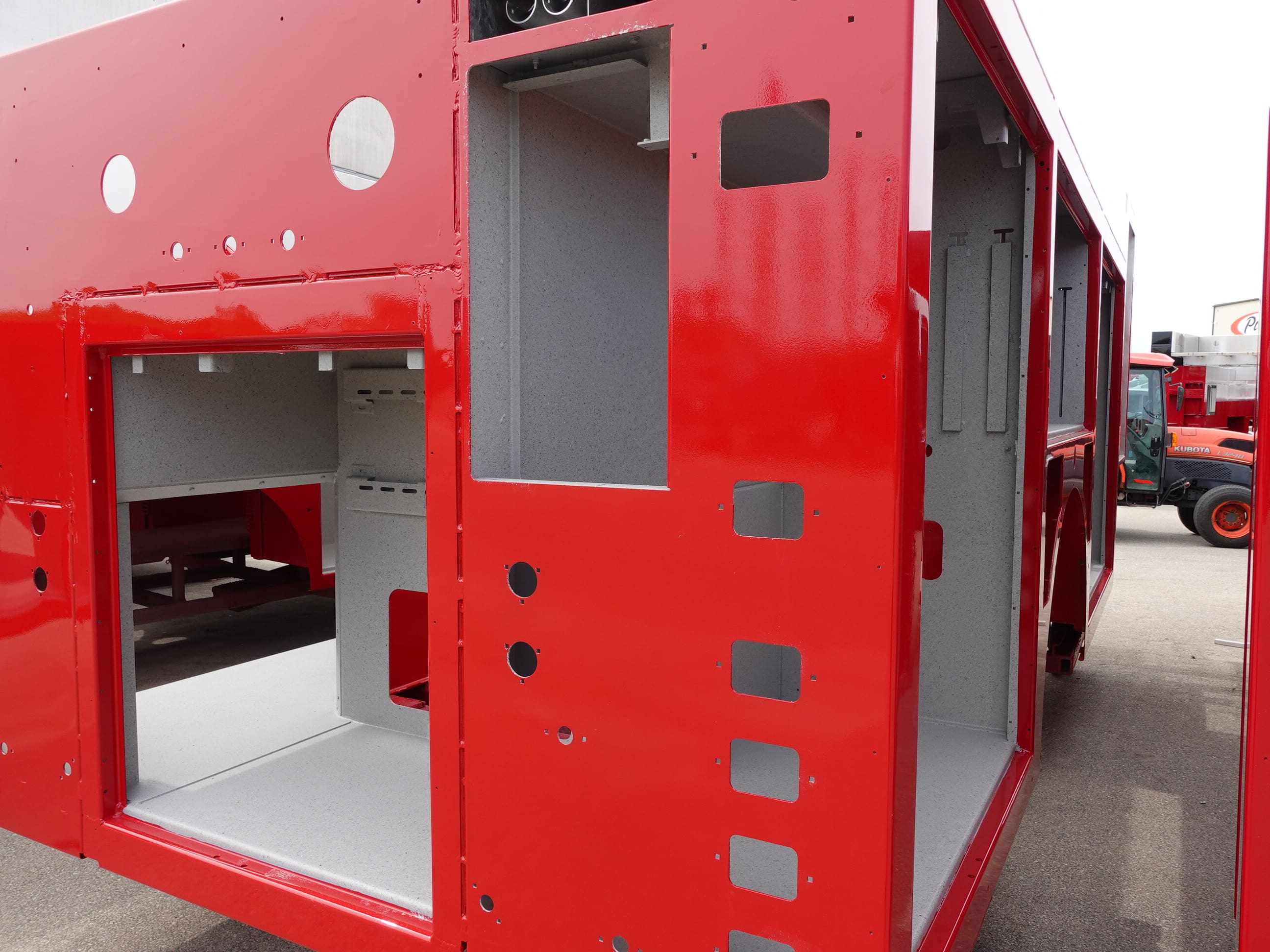

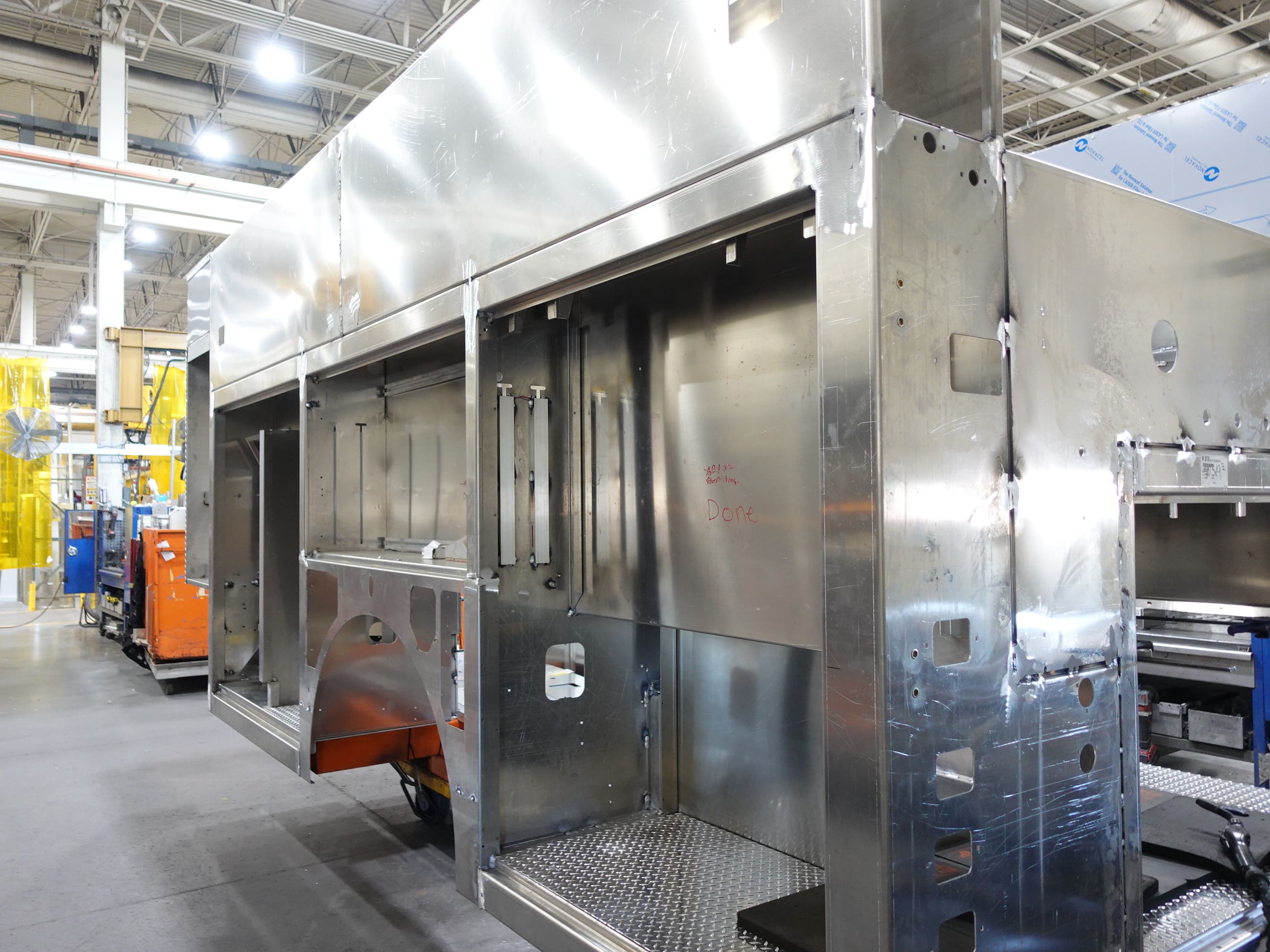

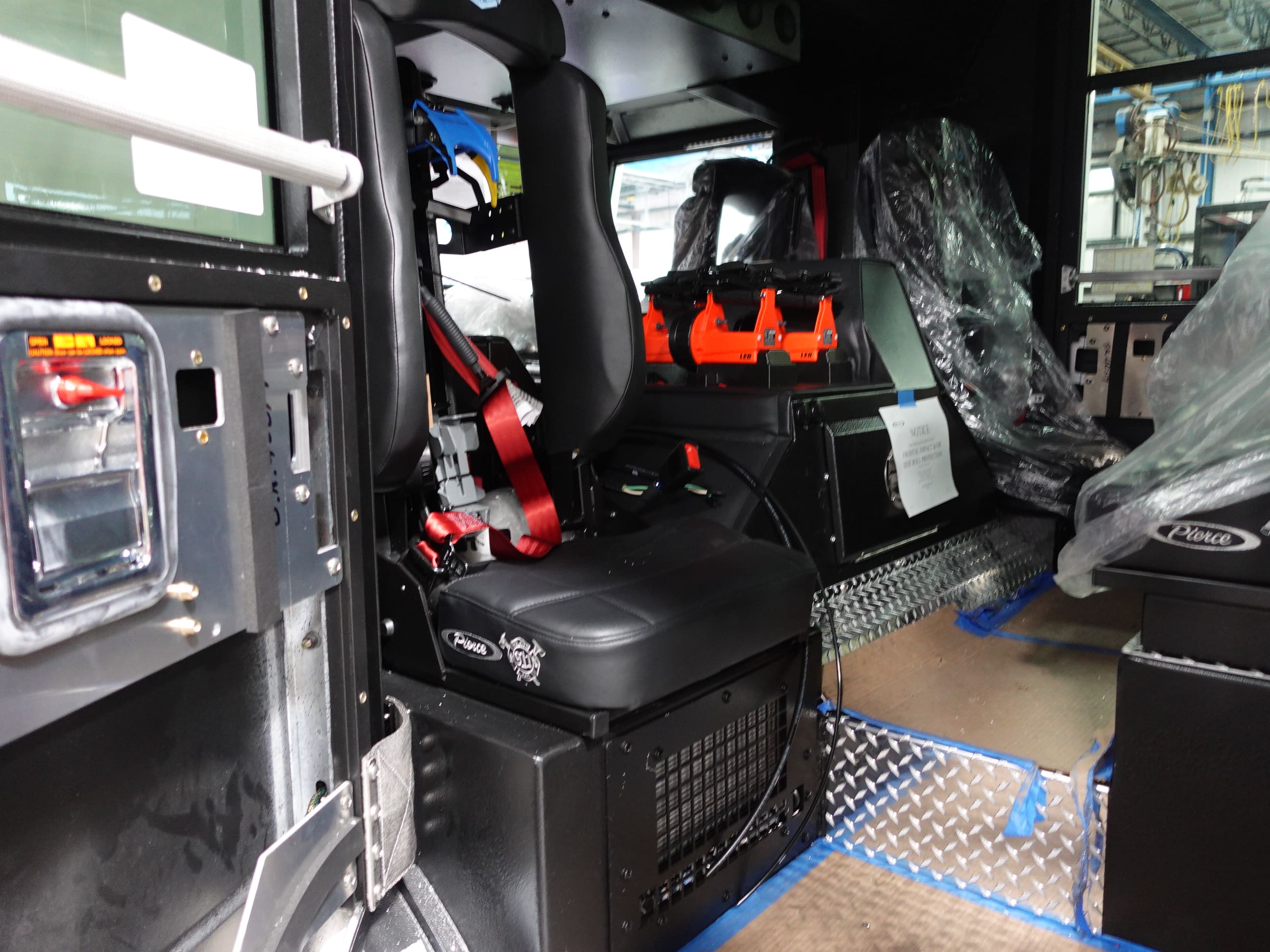

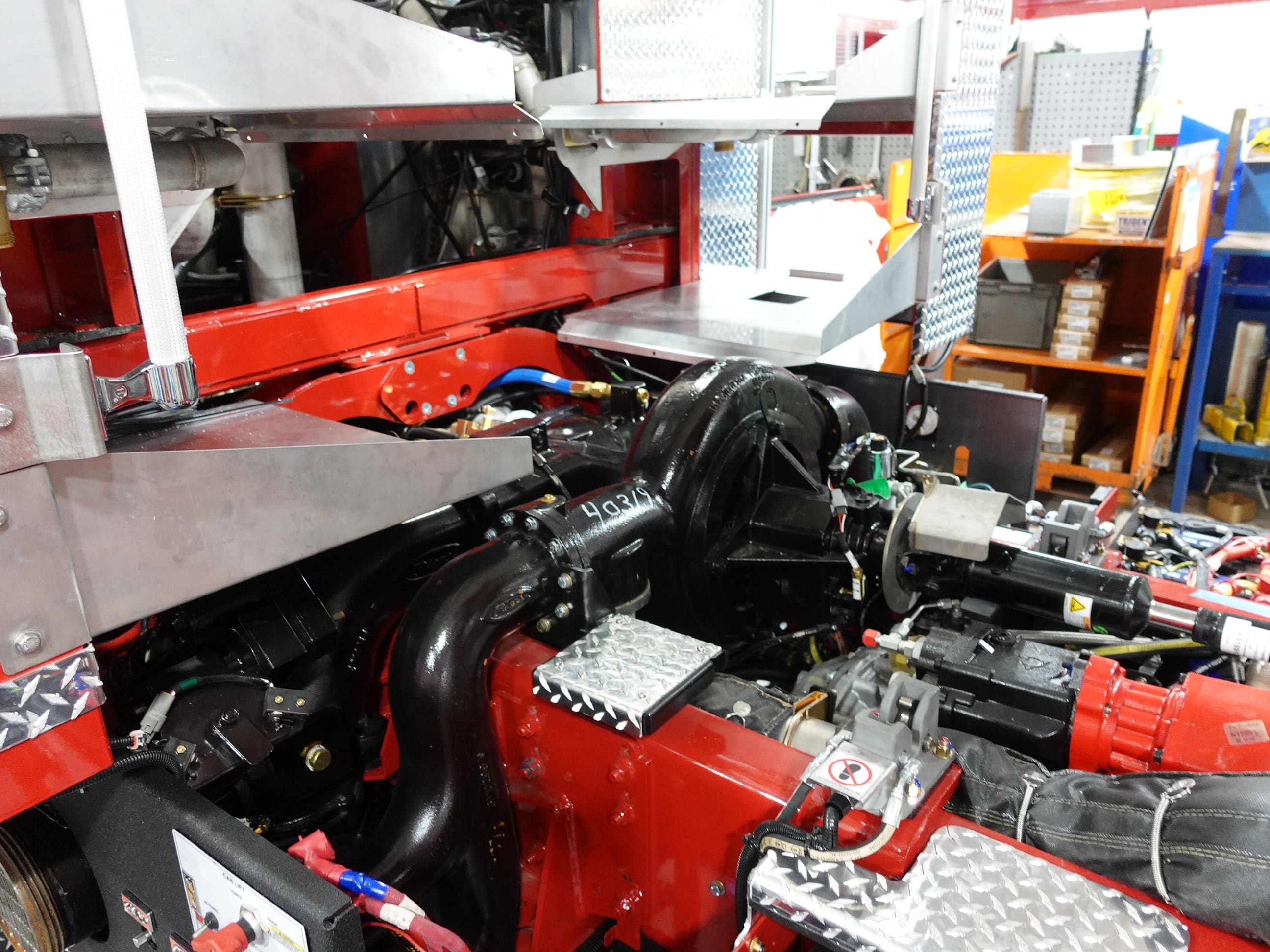

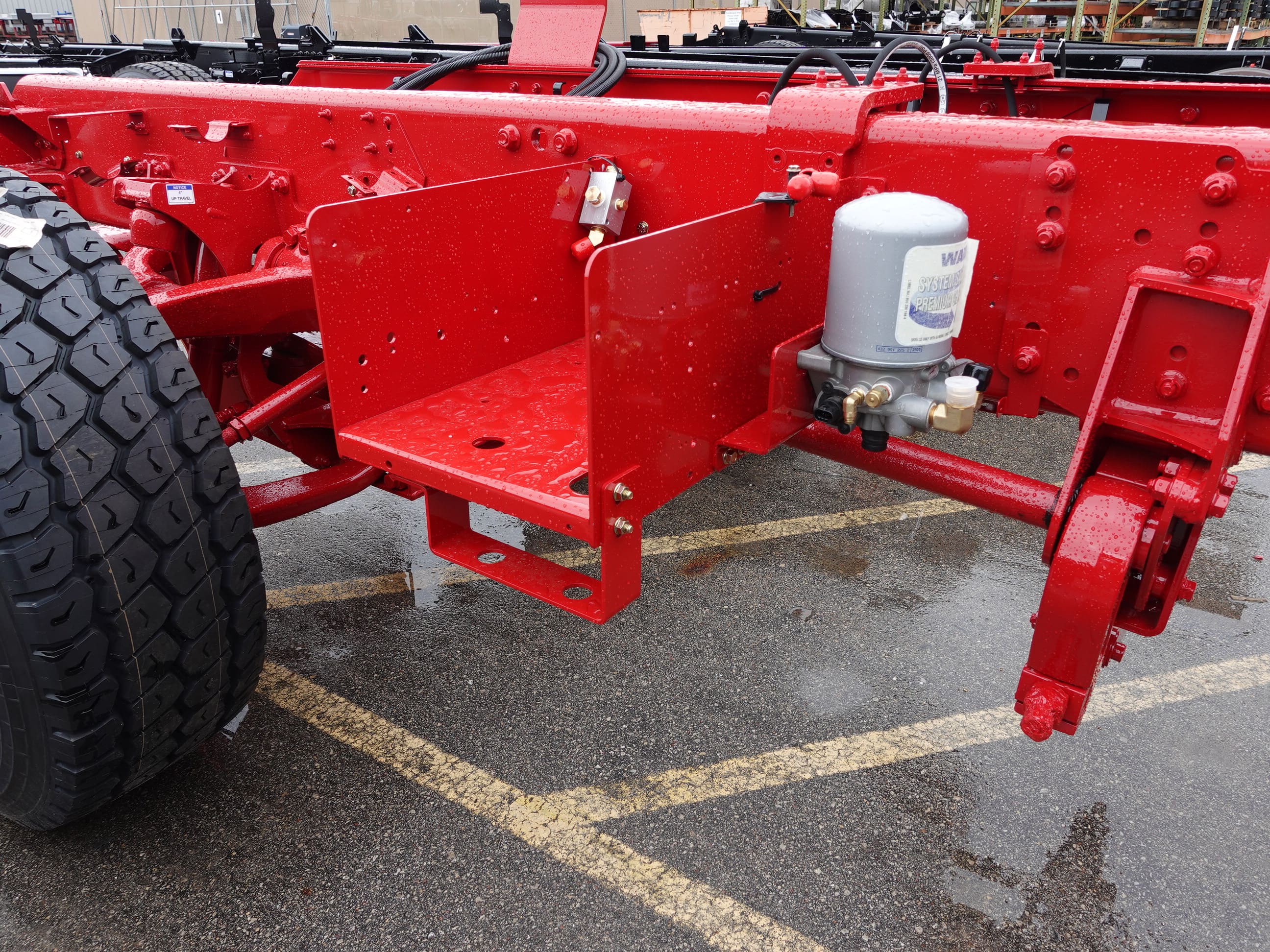

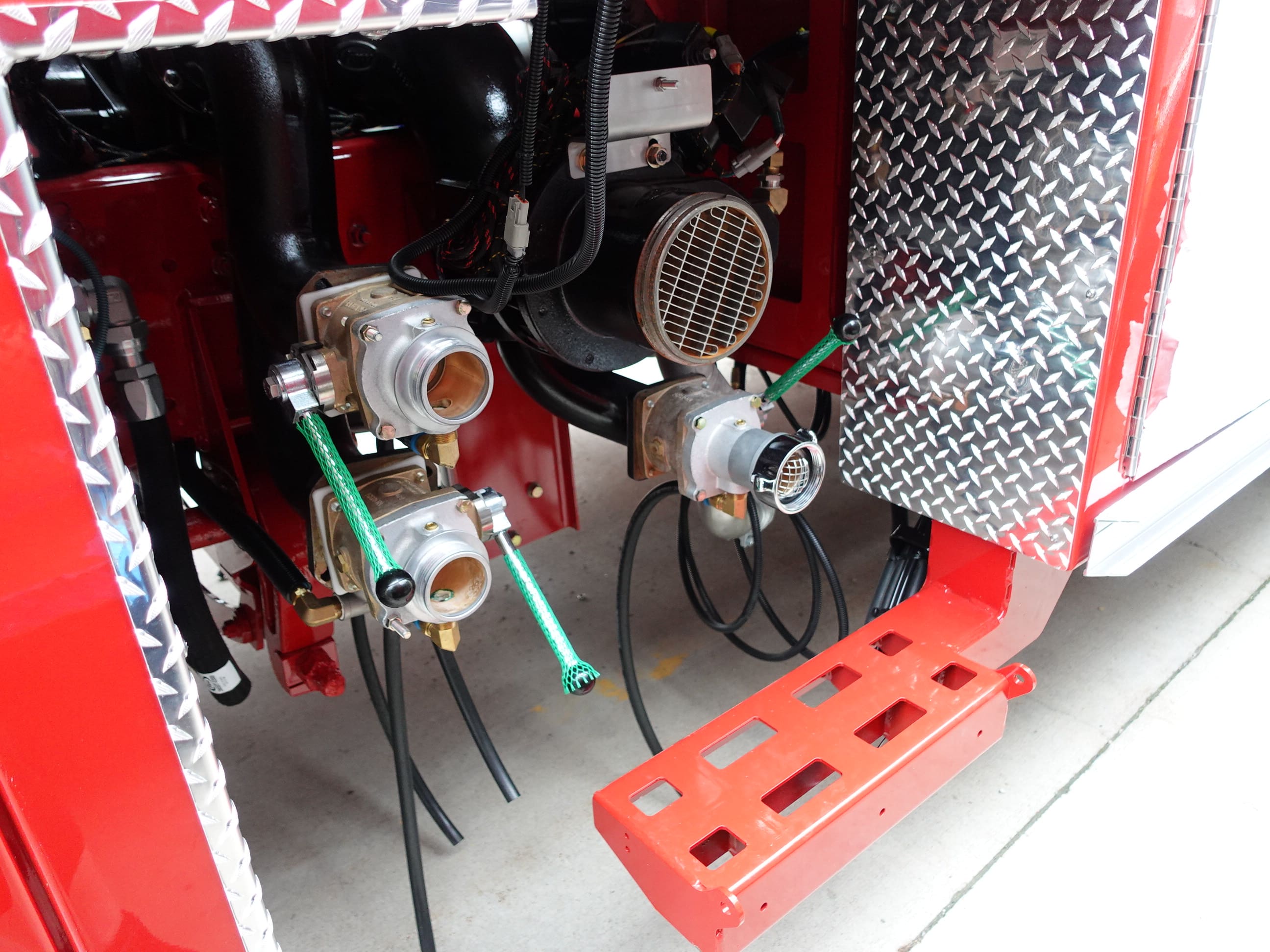

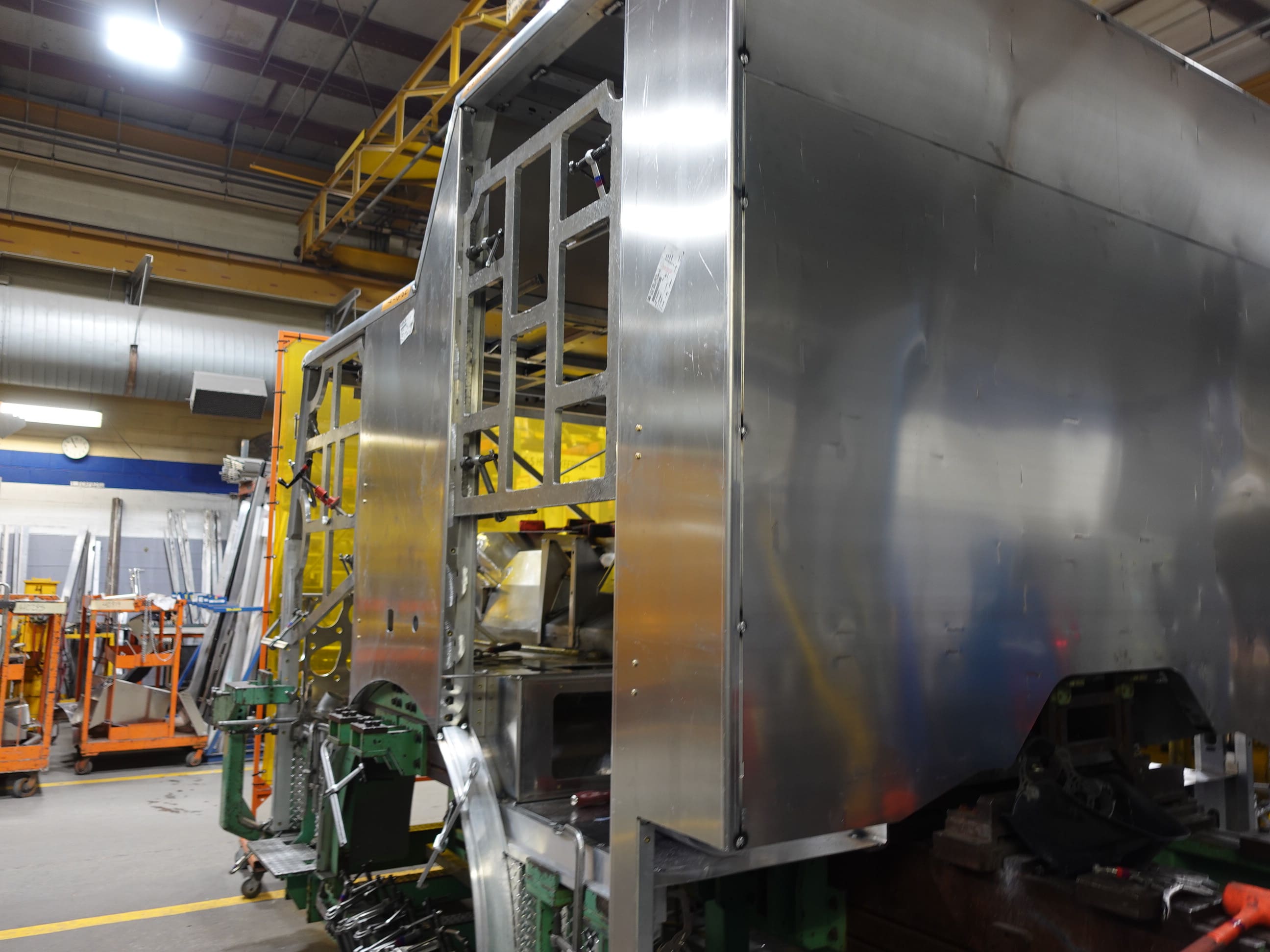

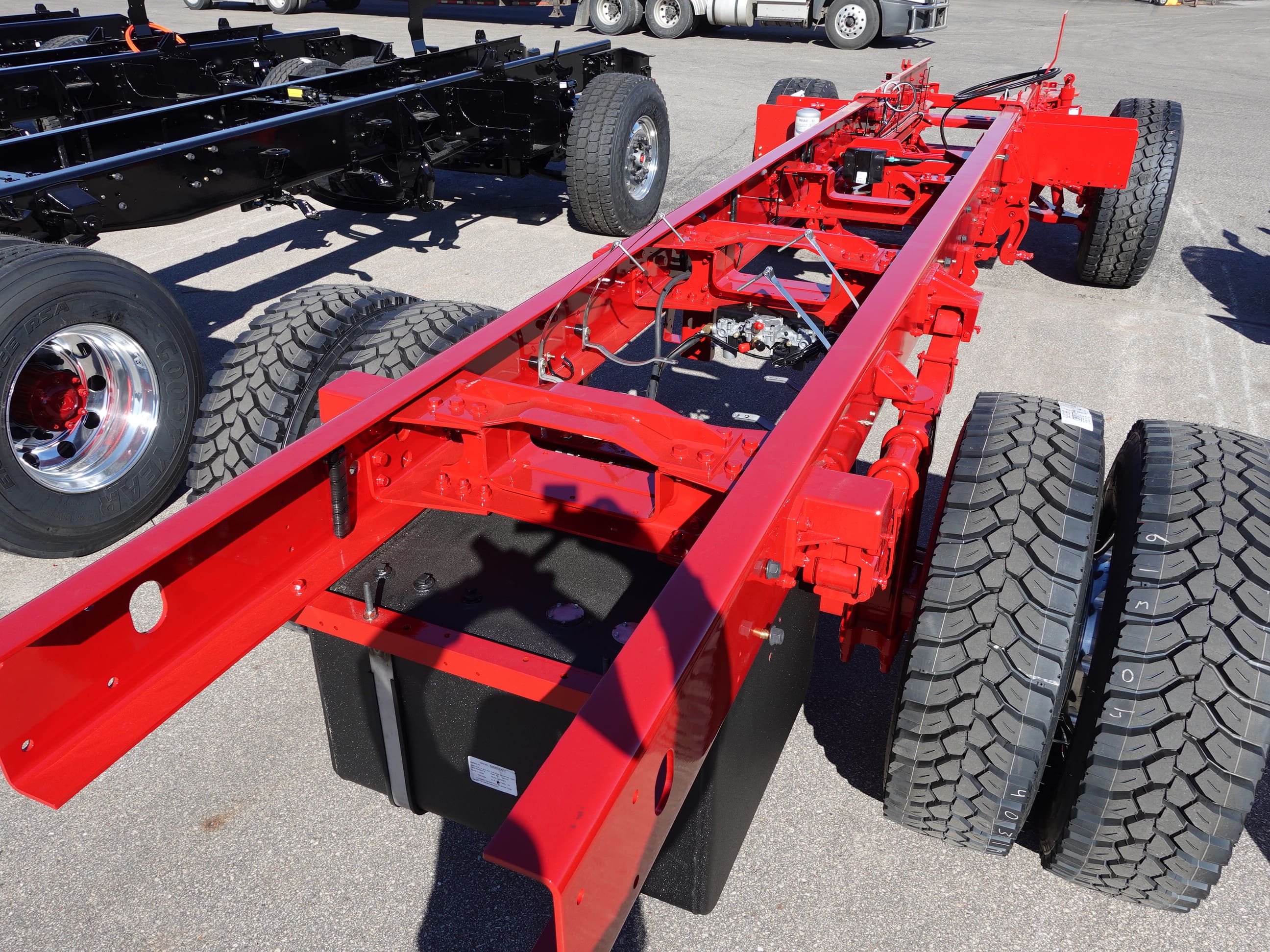

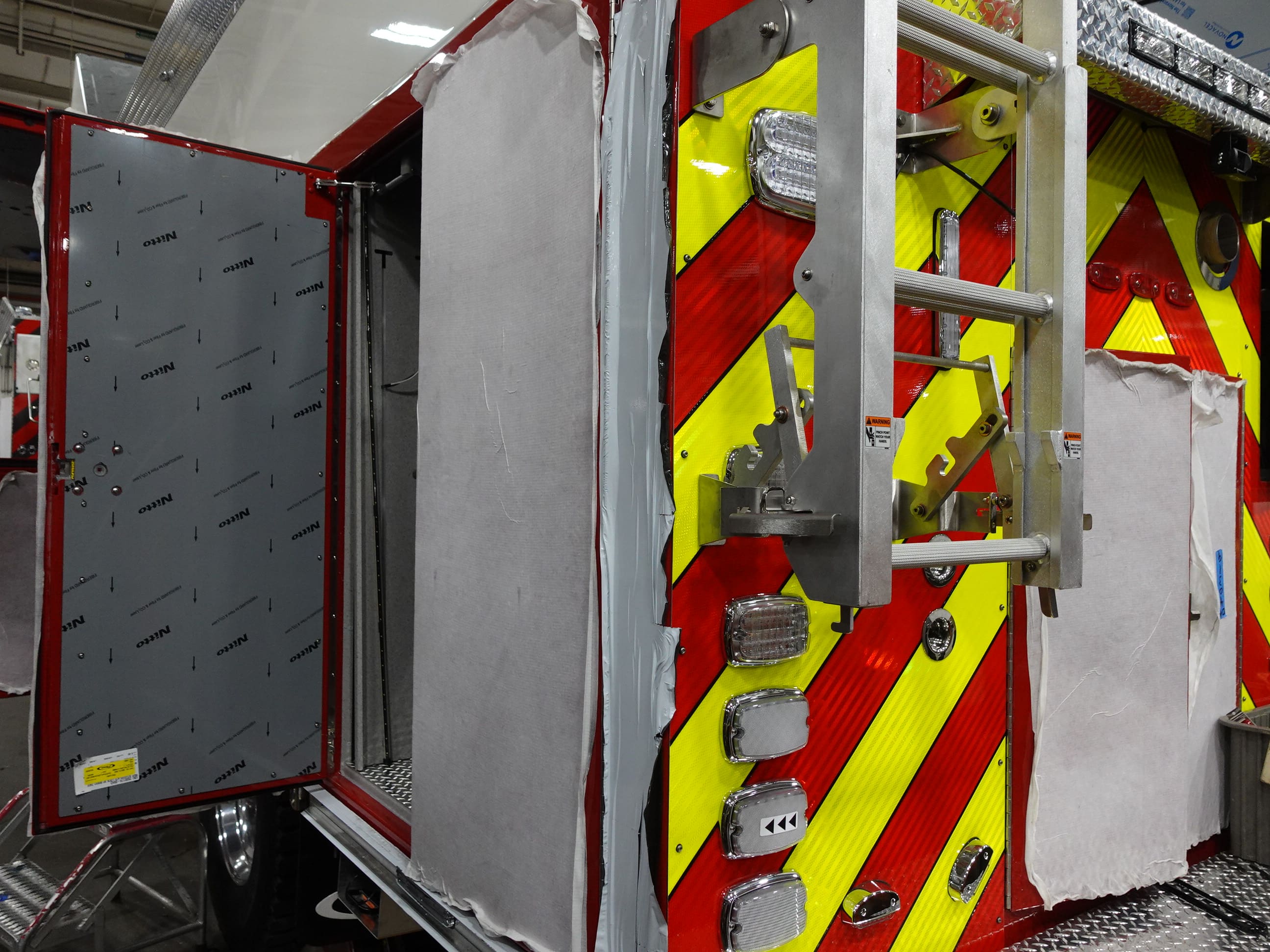

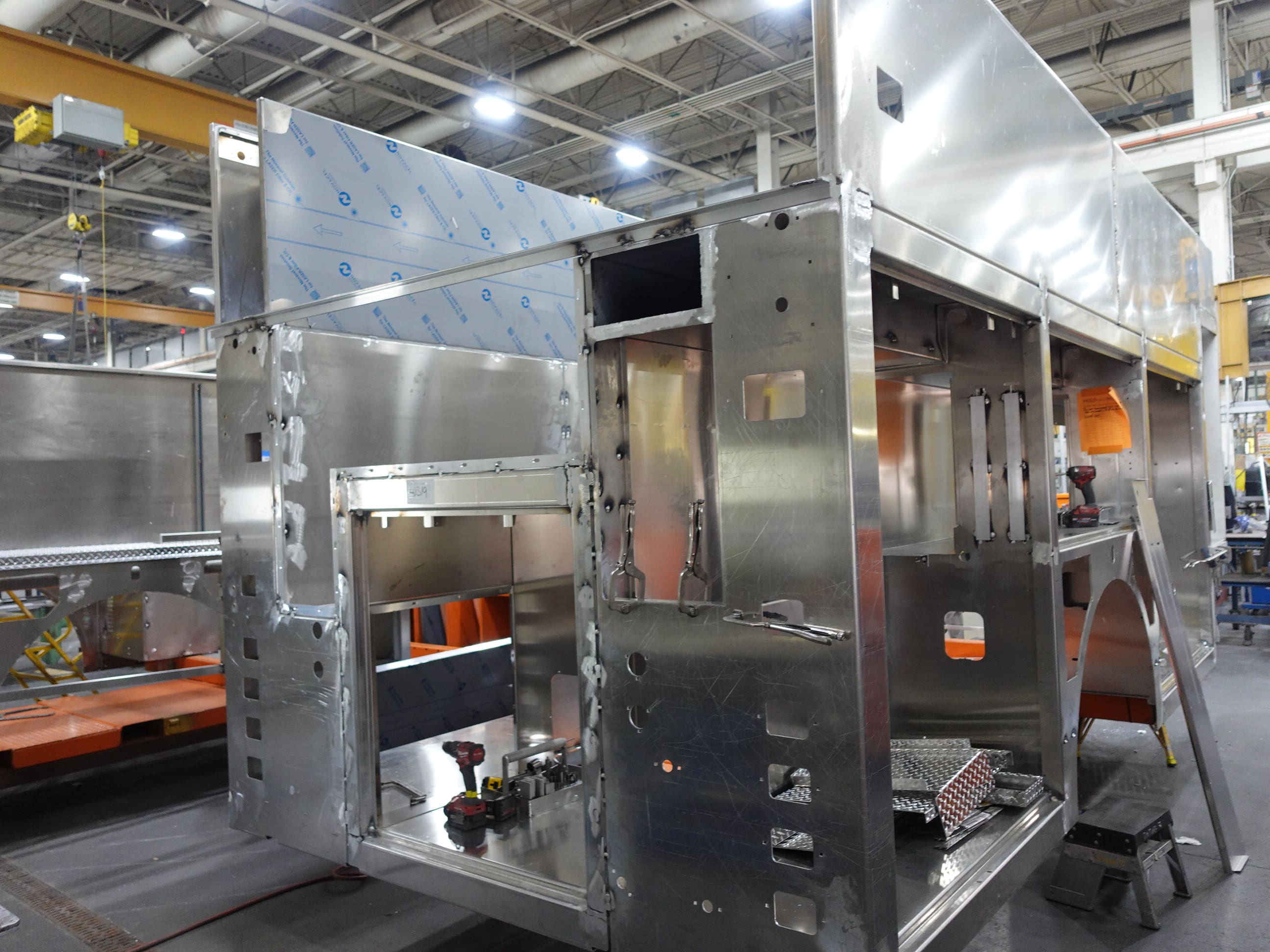

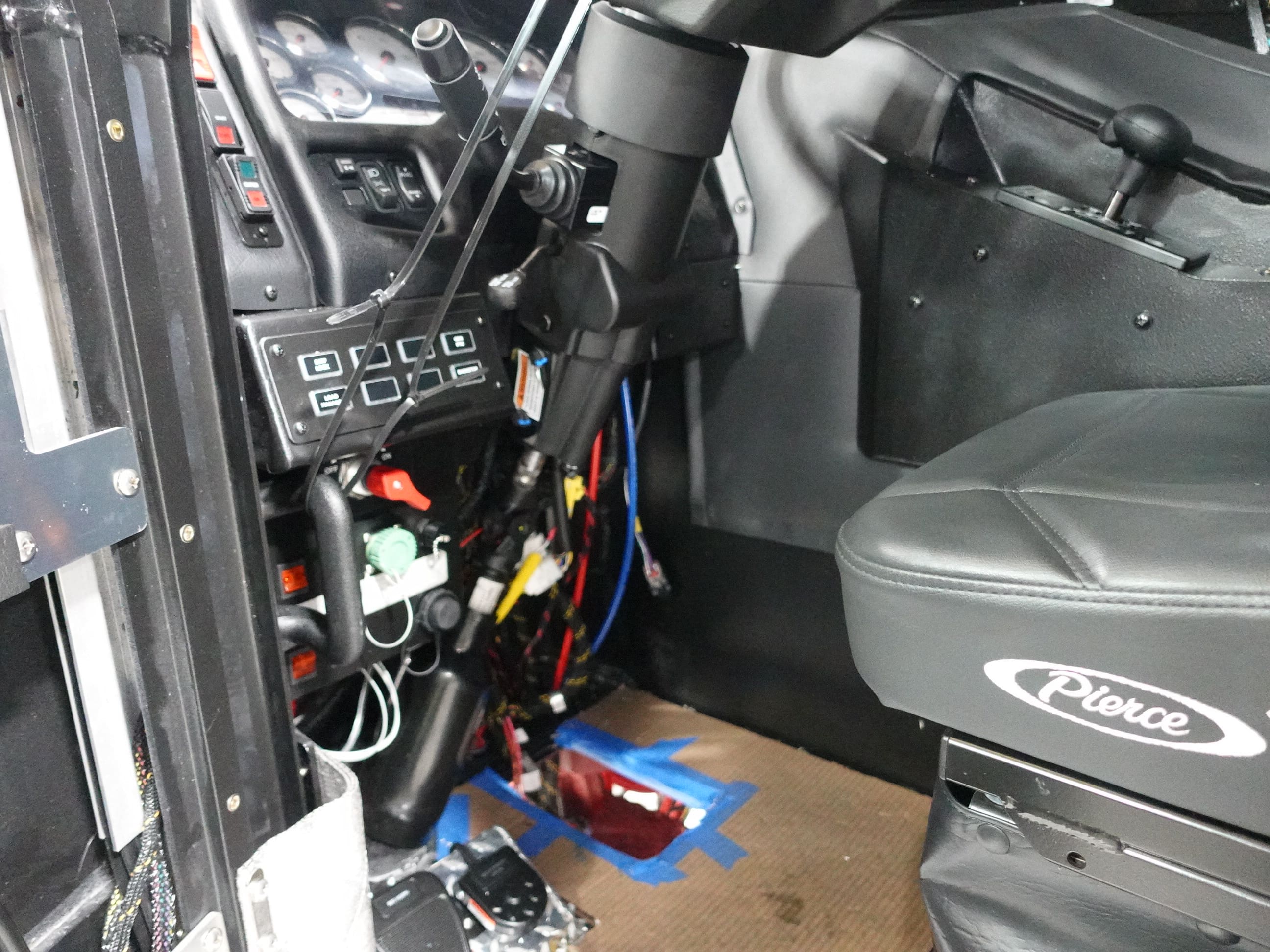

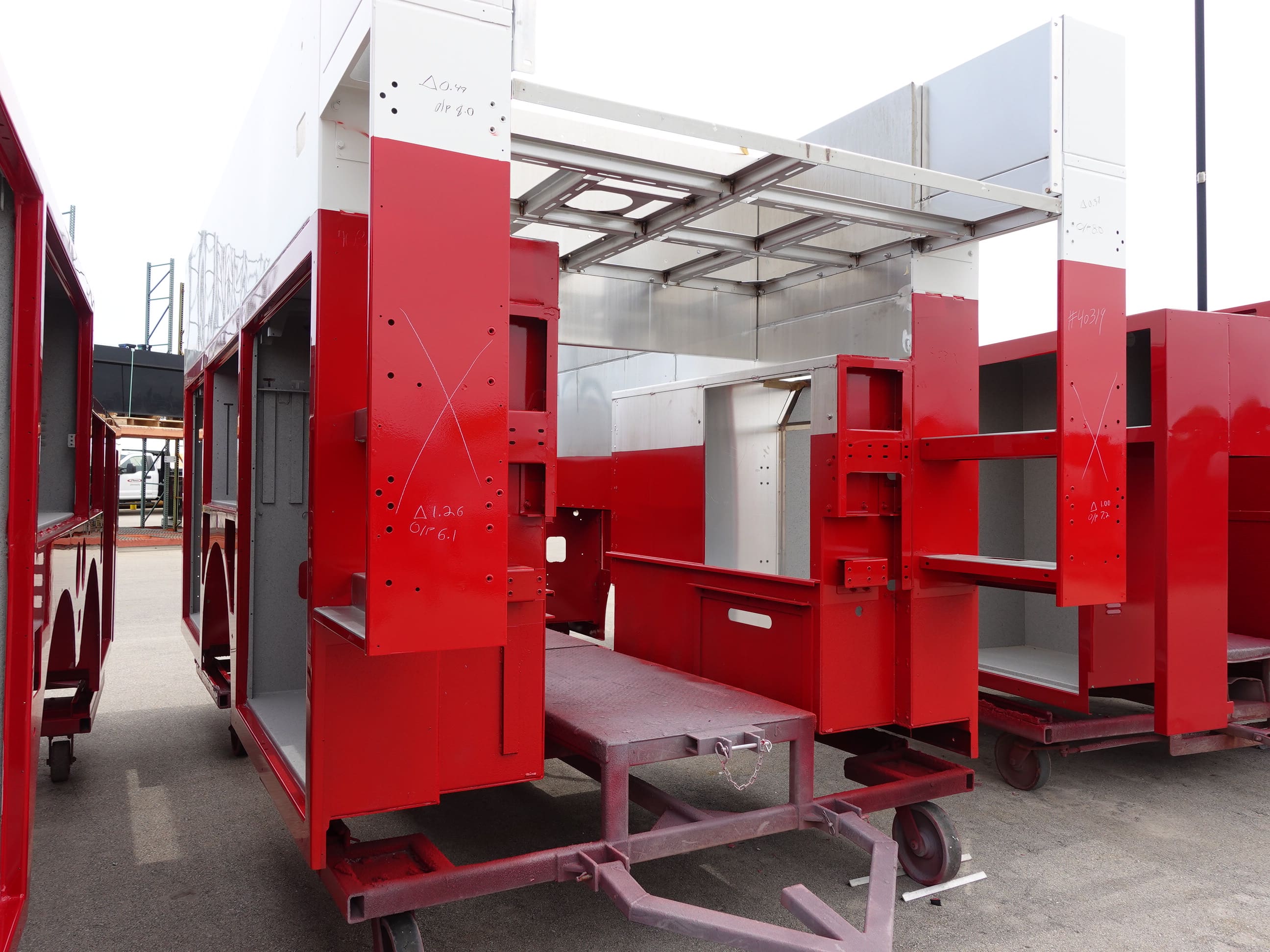

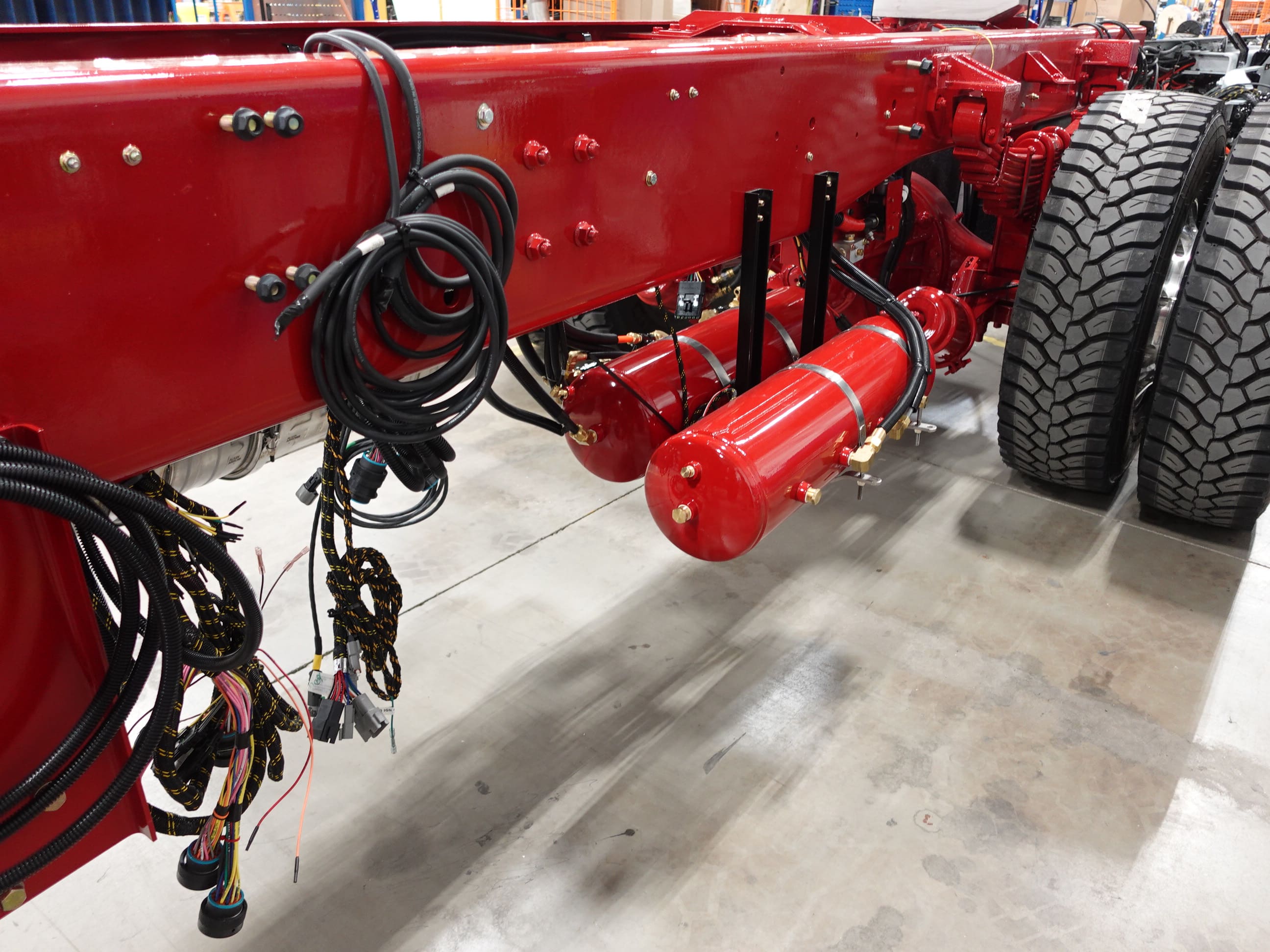

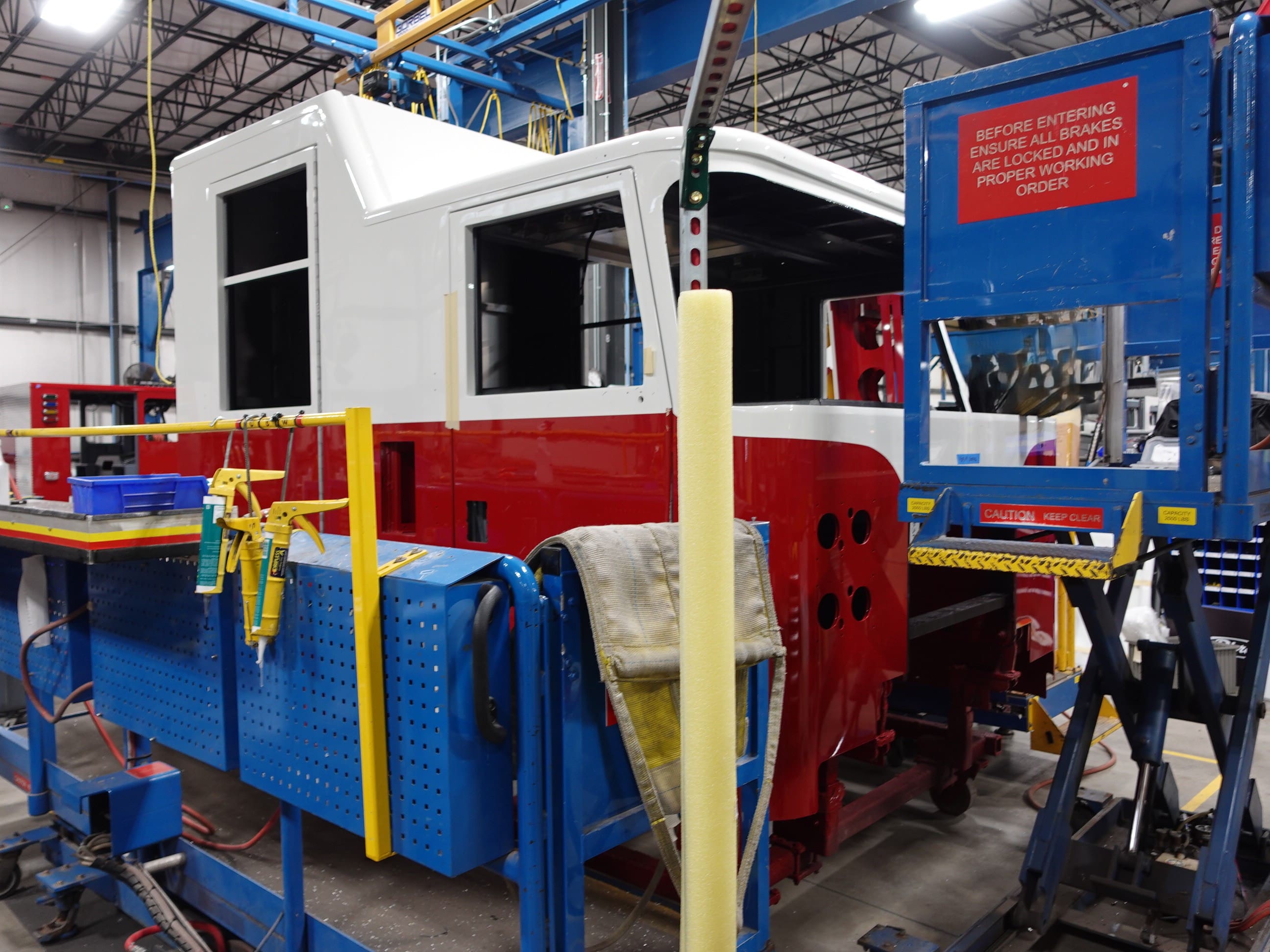

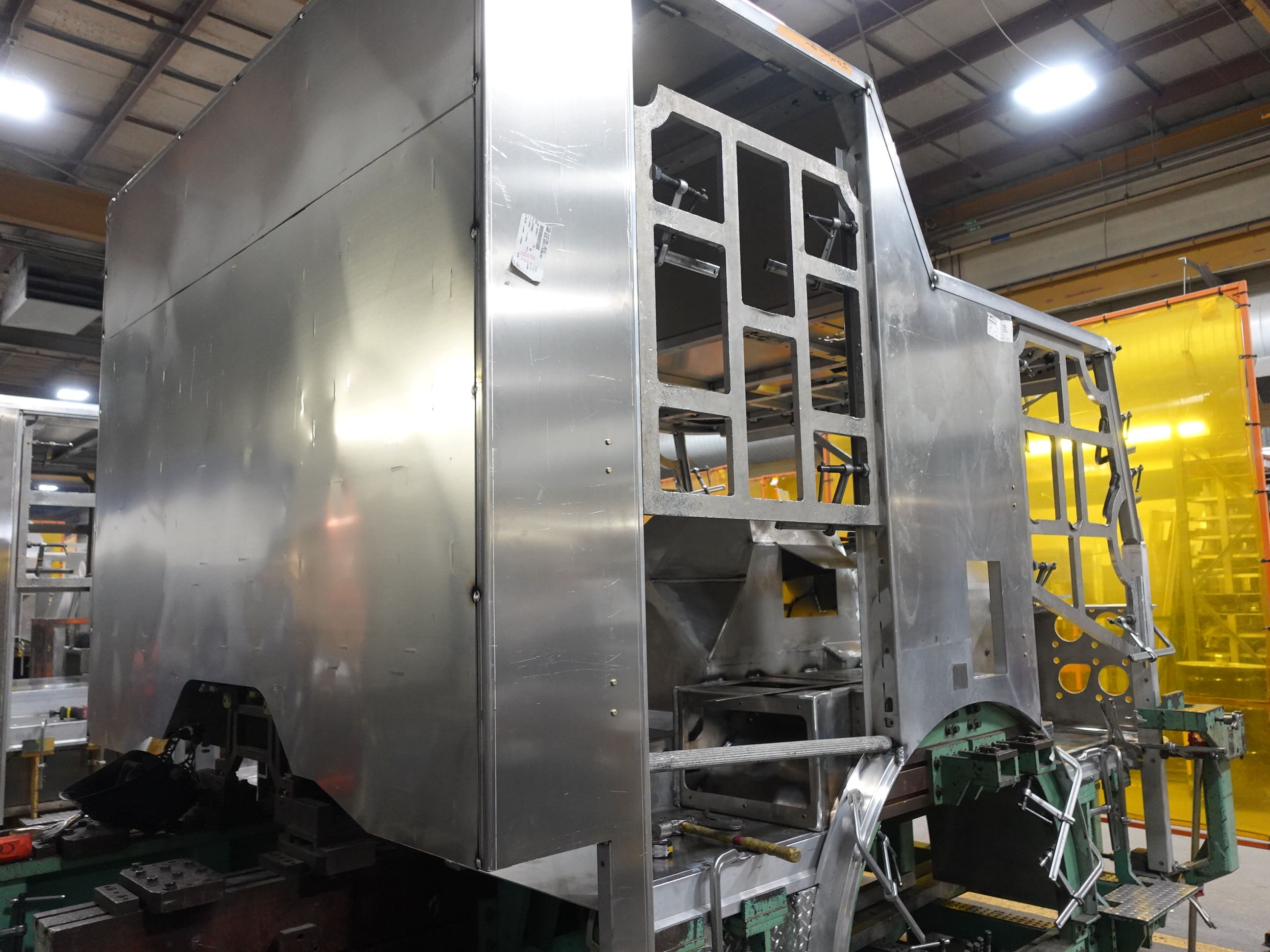

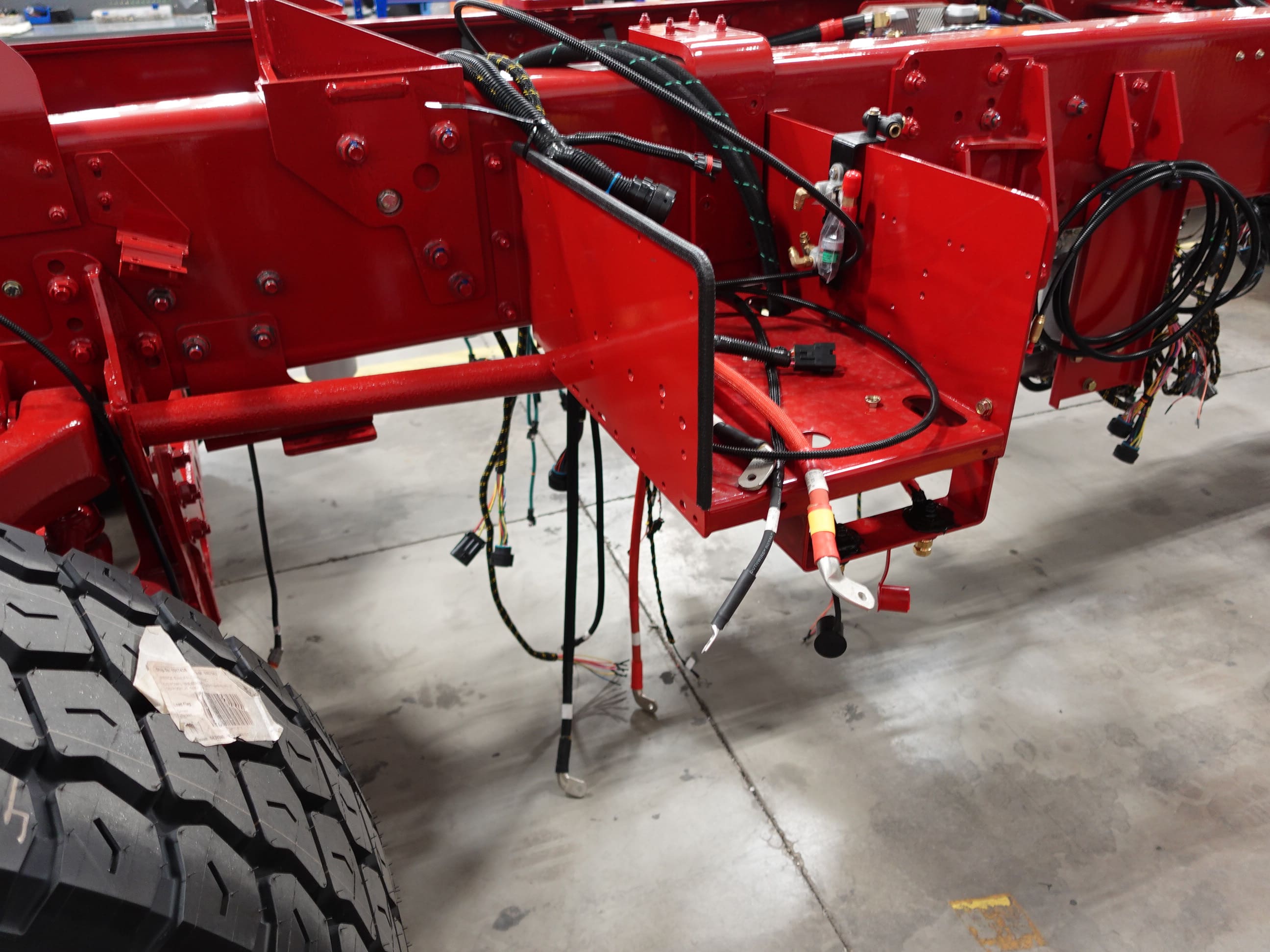

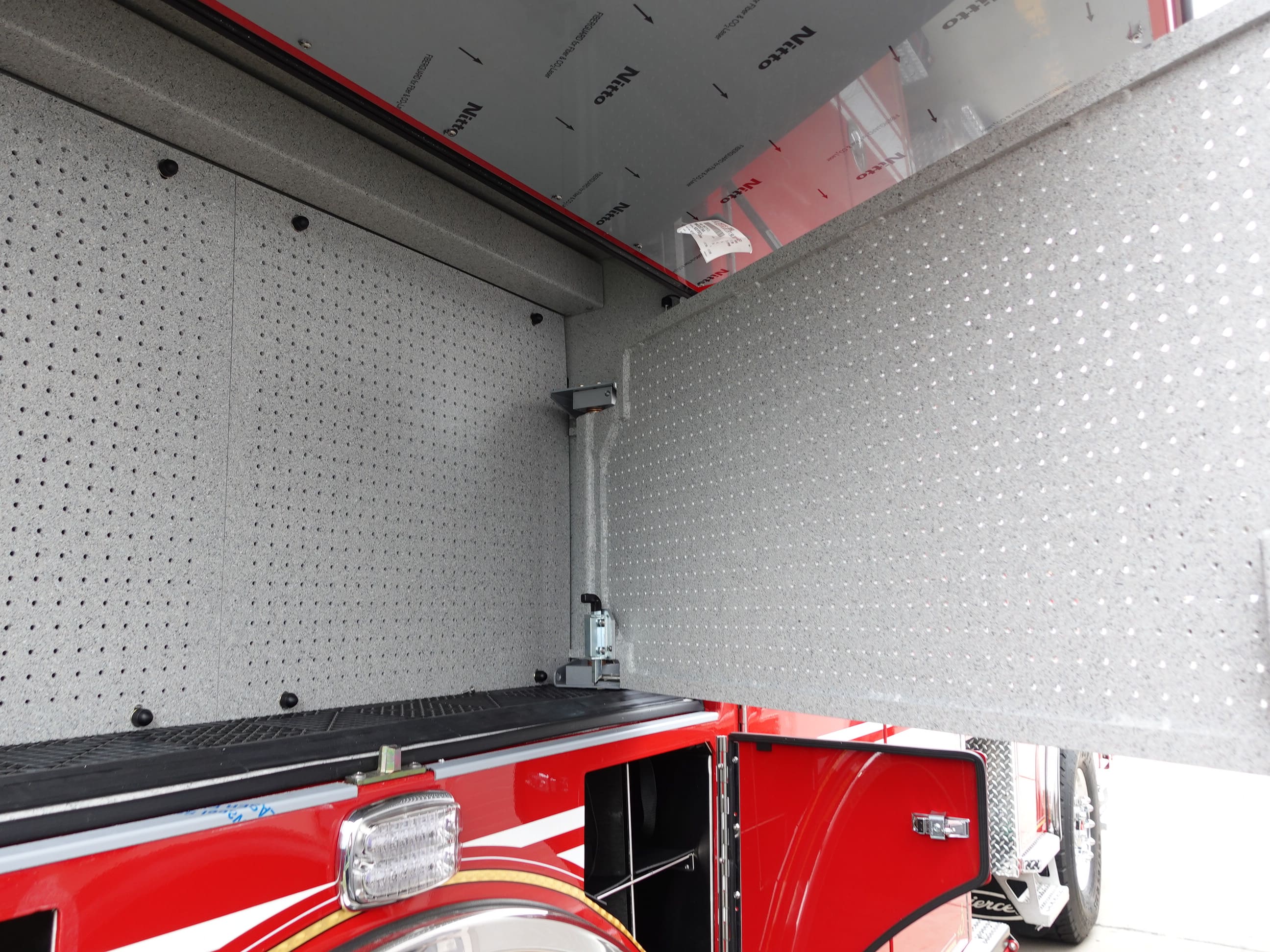

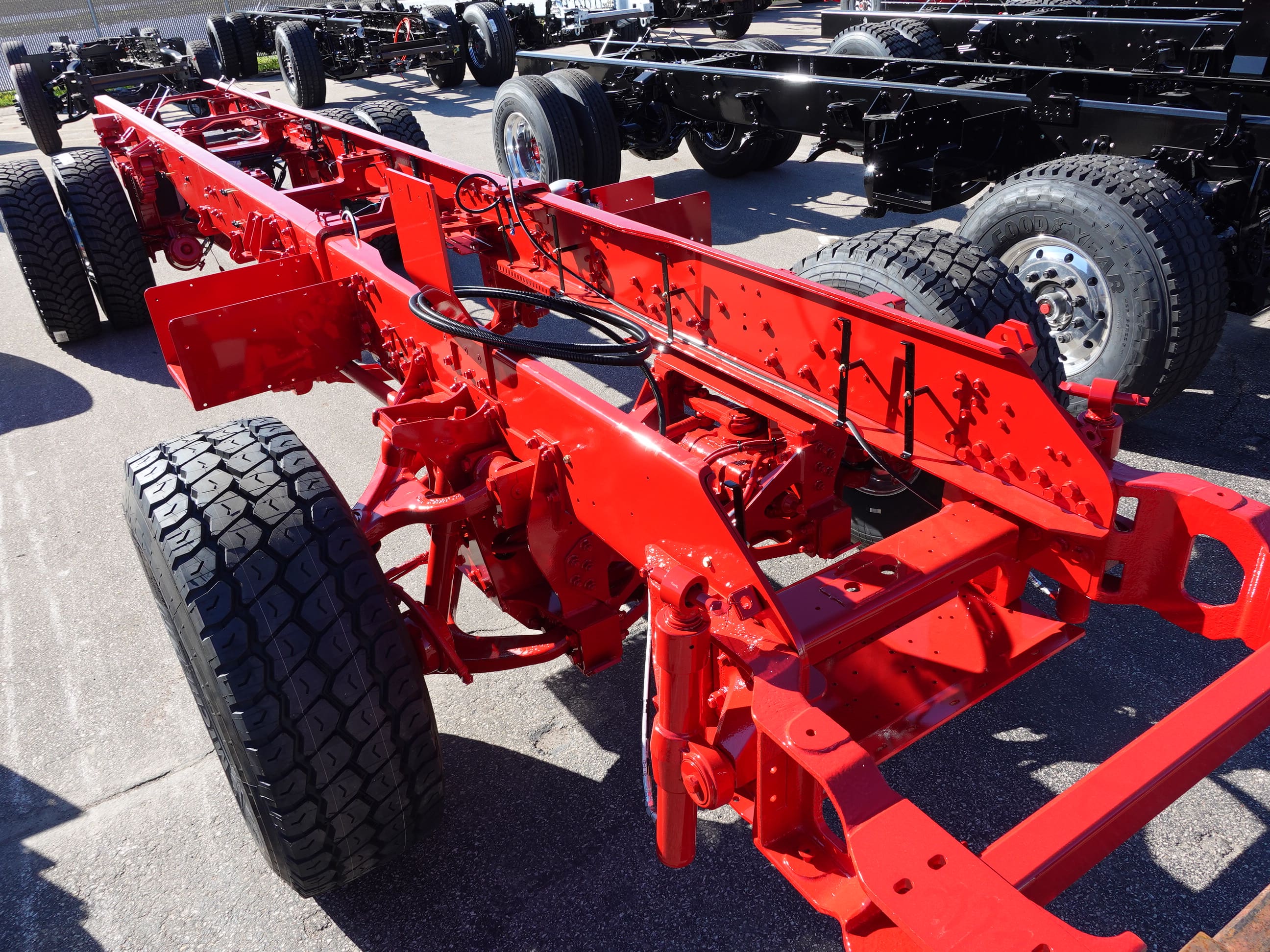

In this report, the cab and body were merged with

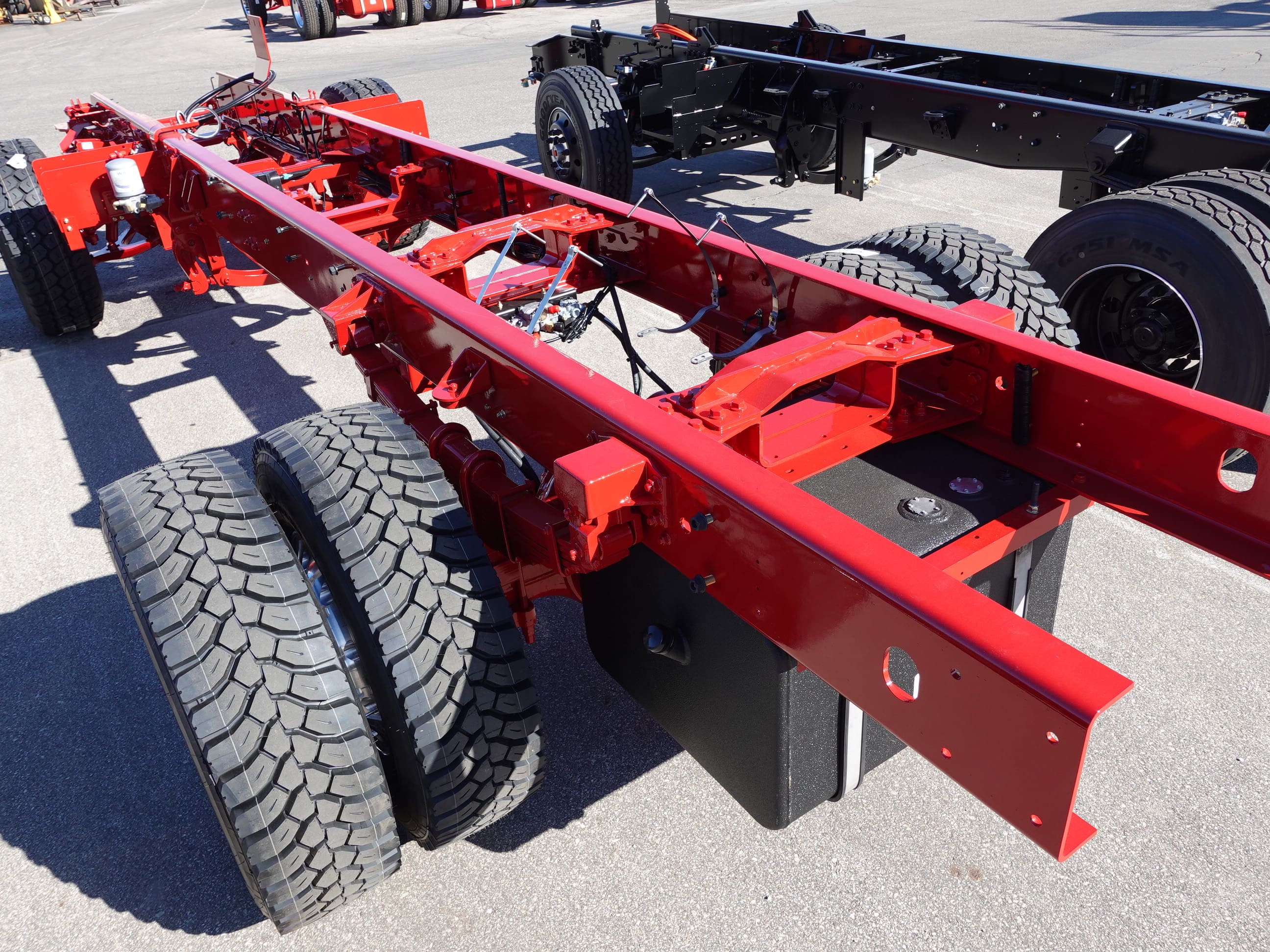

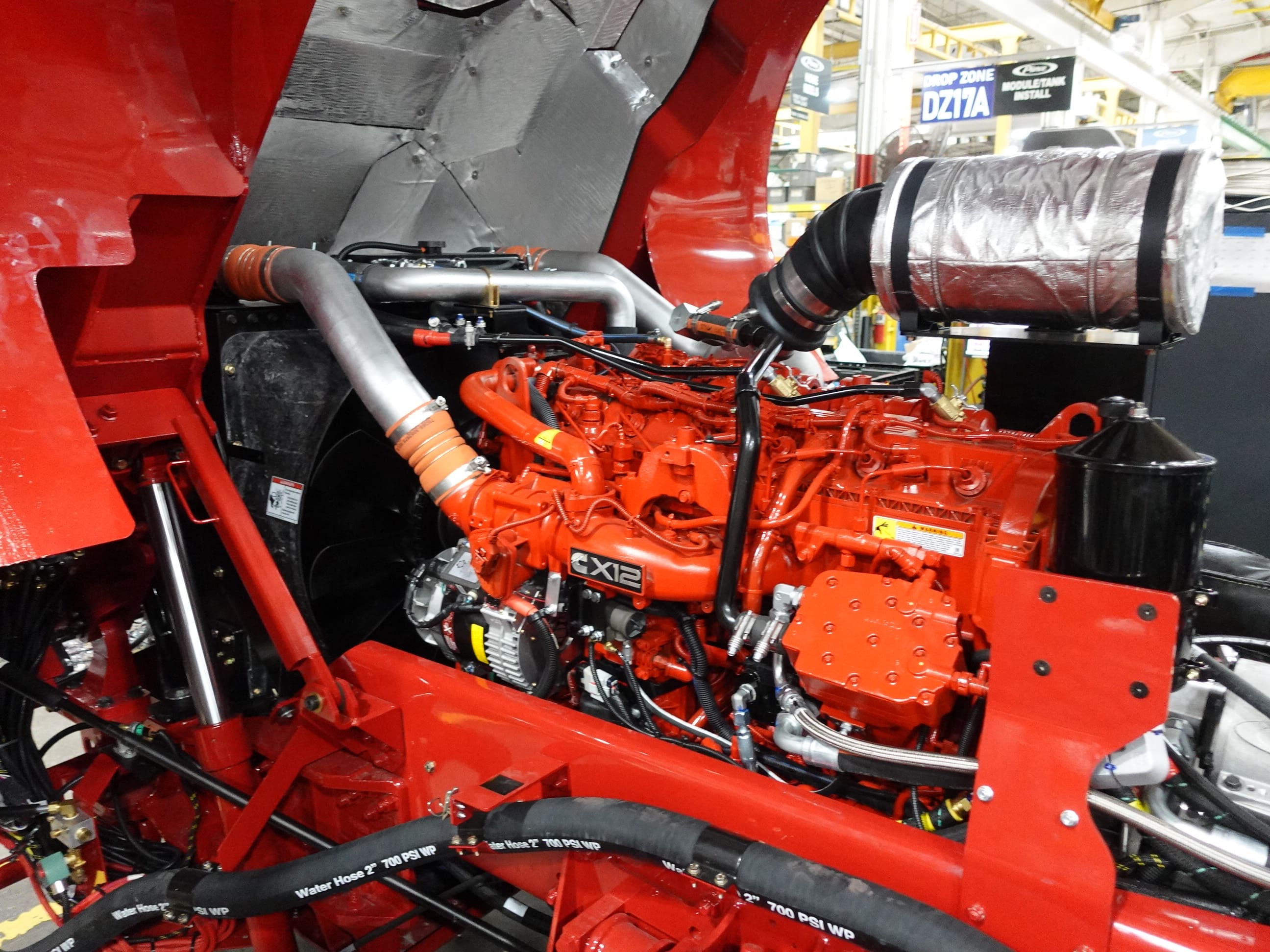

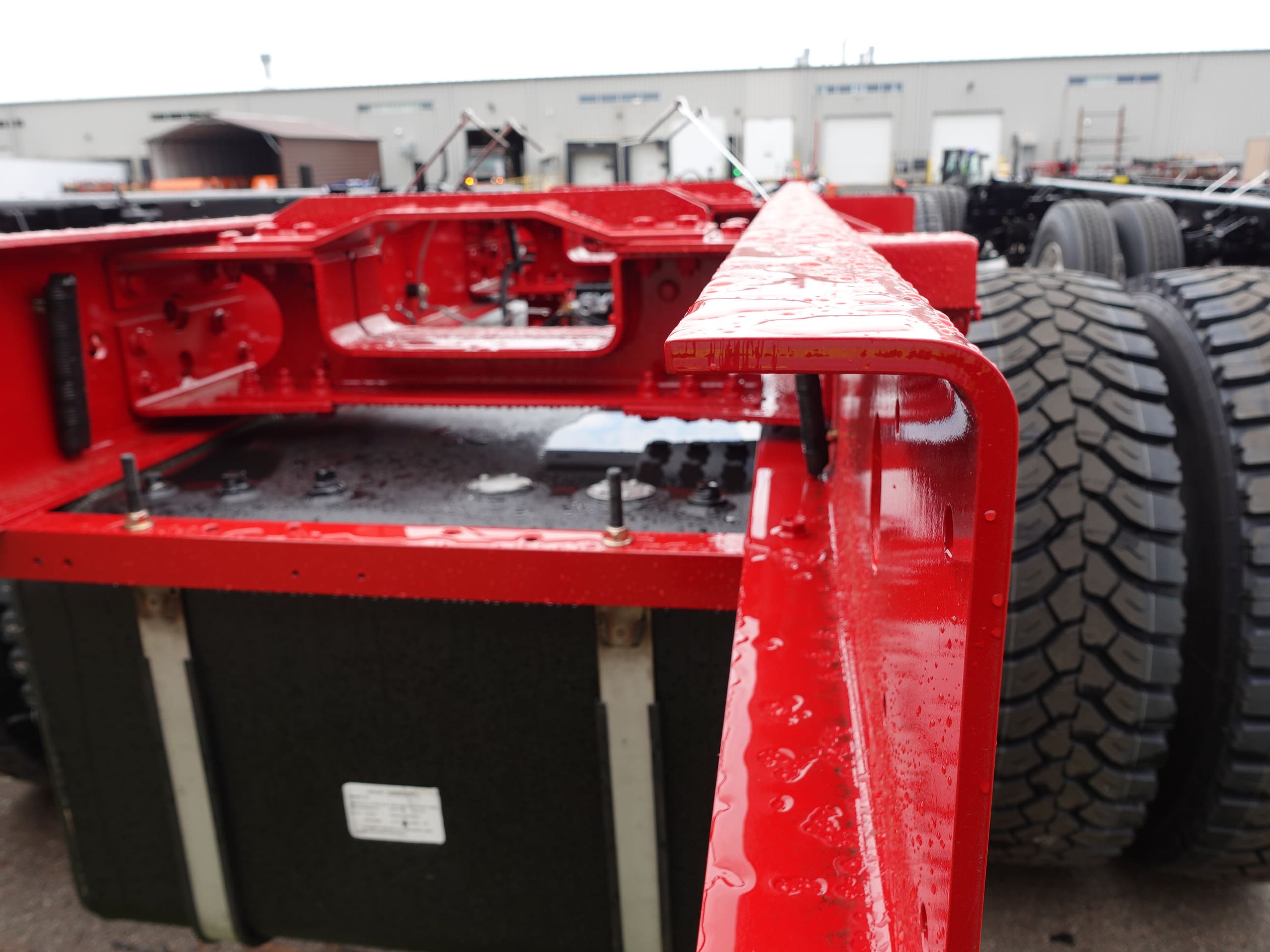

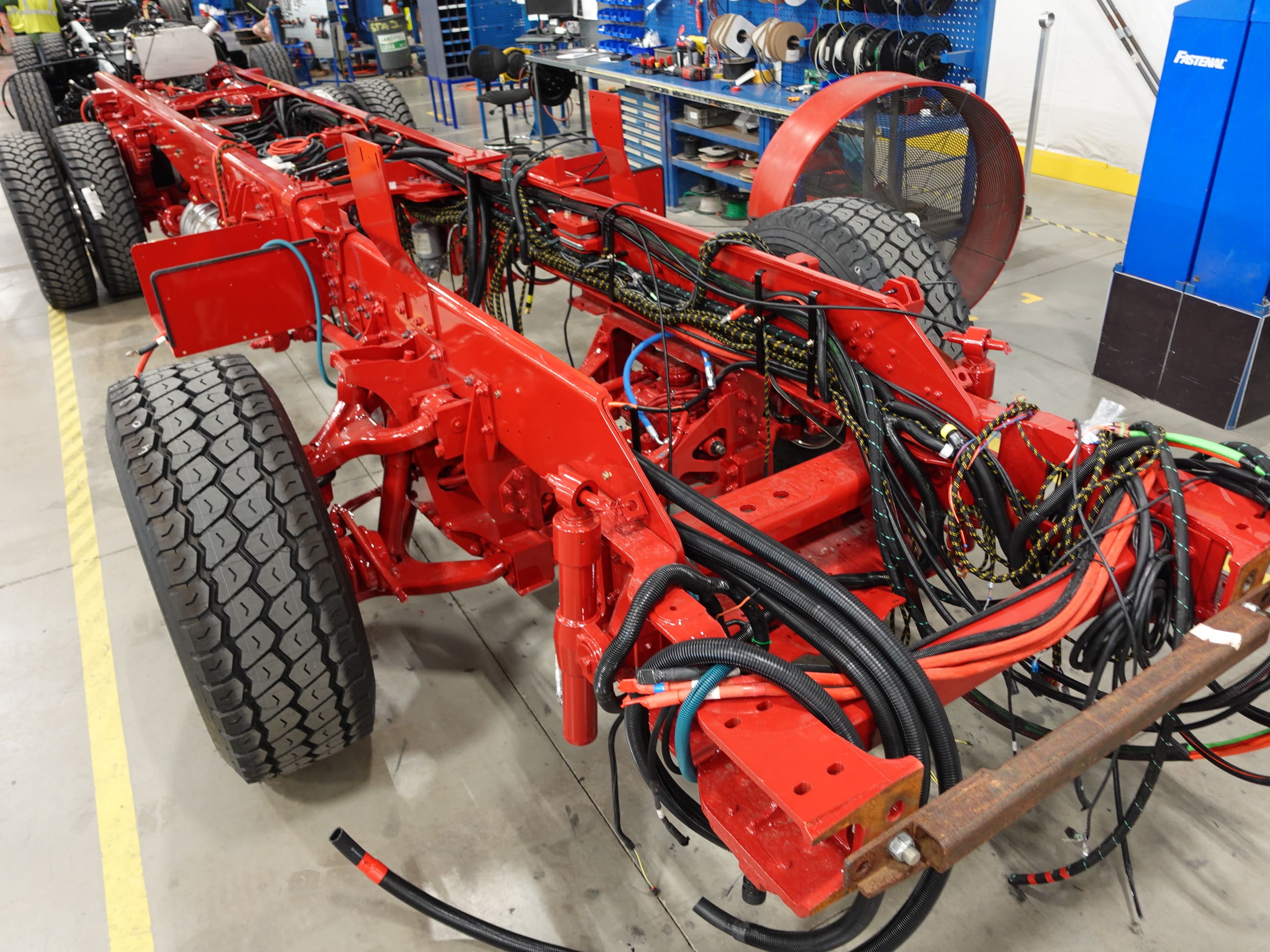

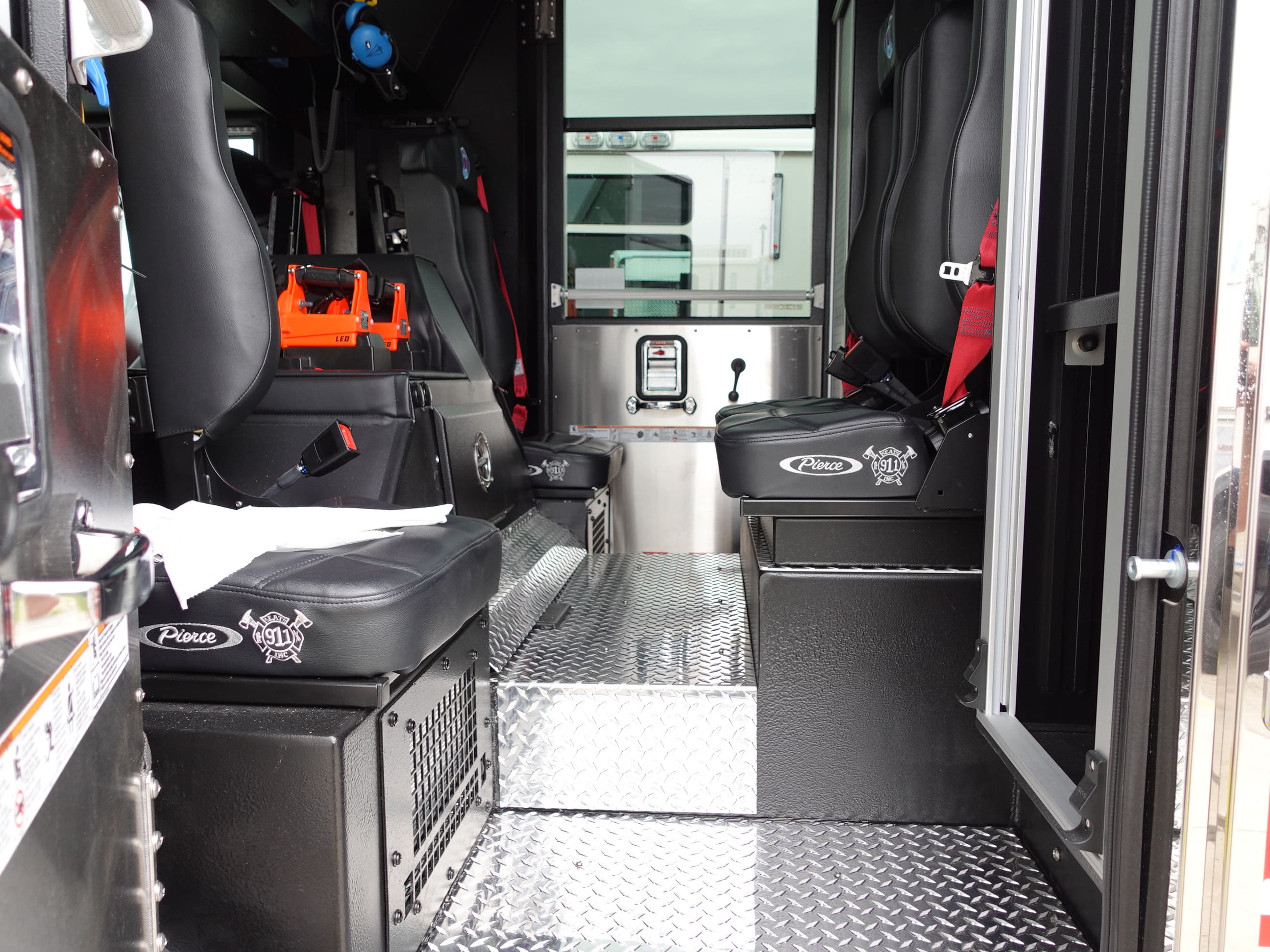

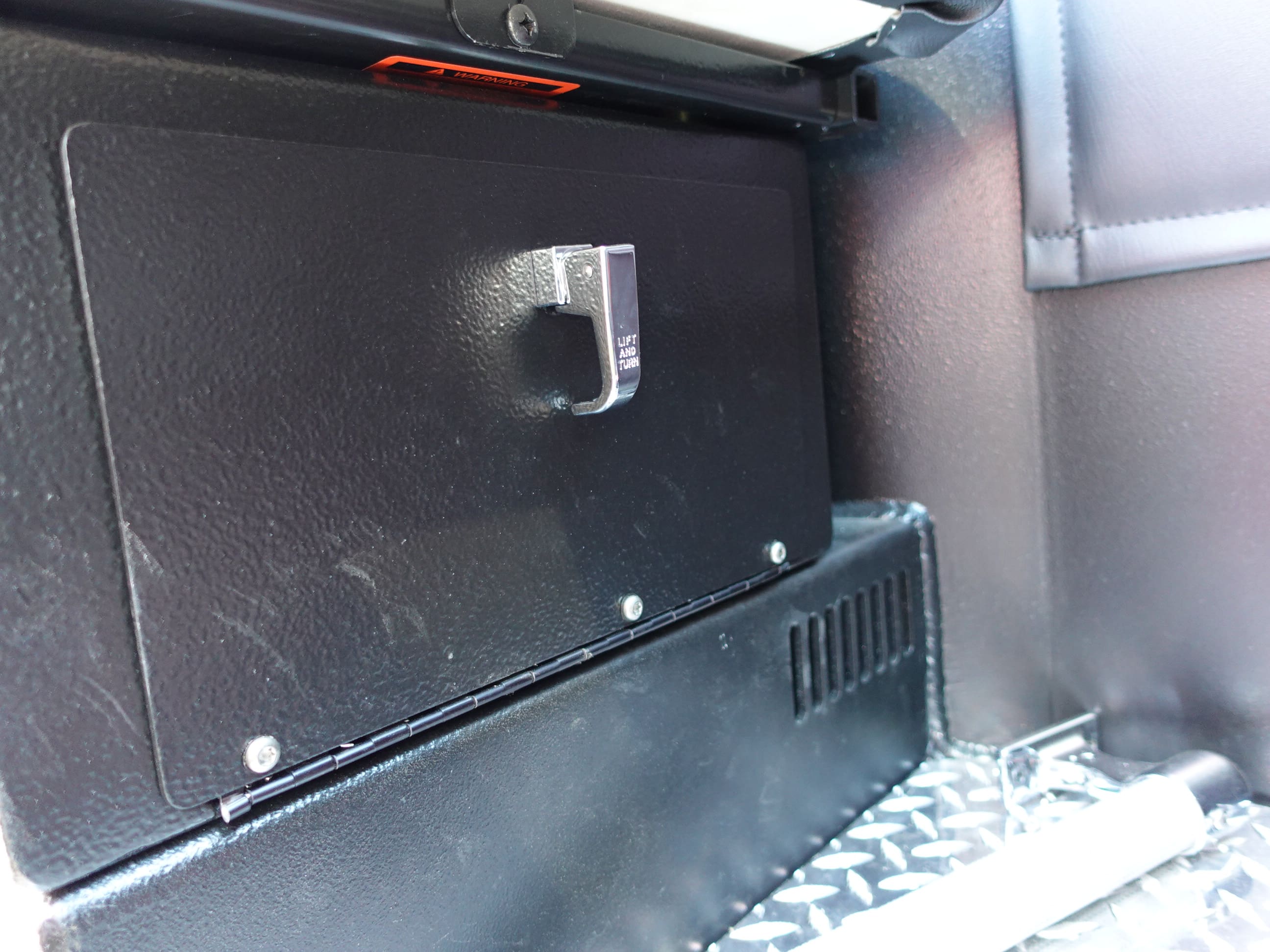

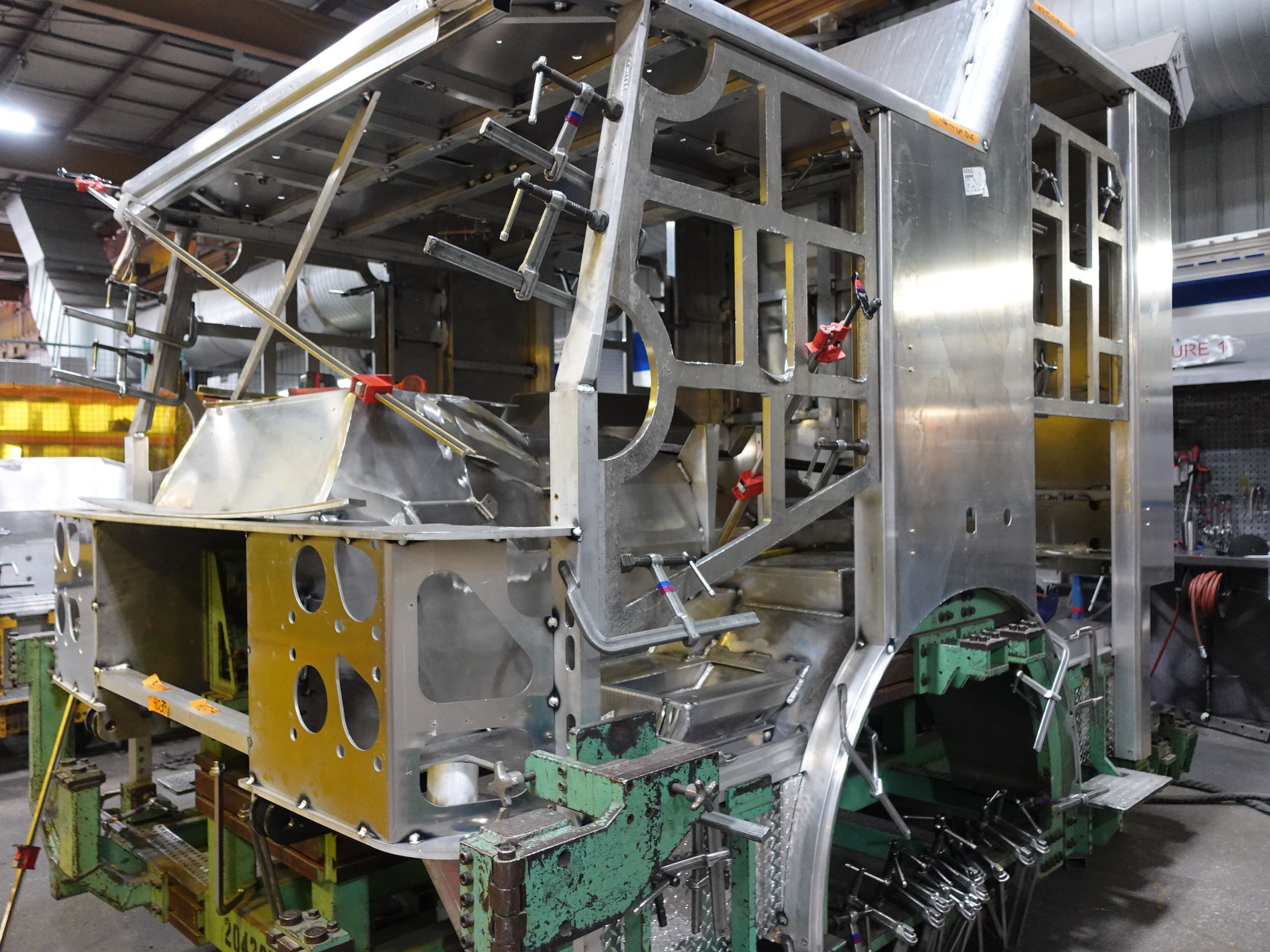

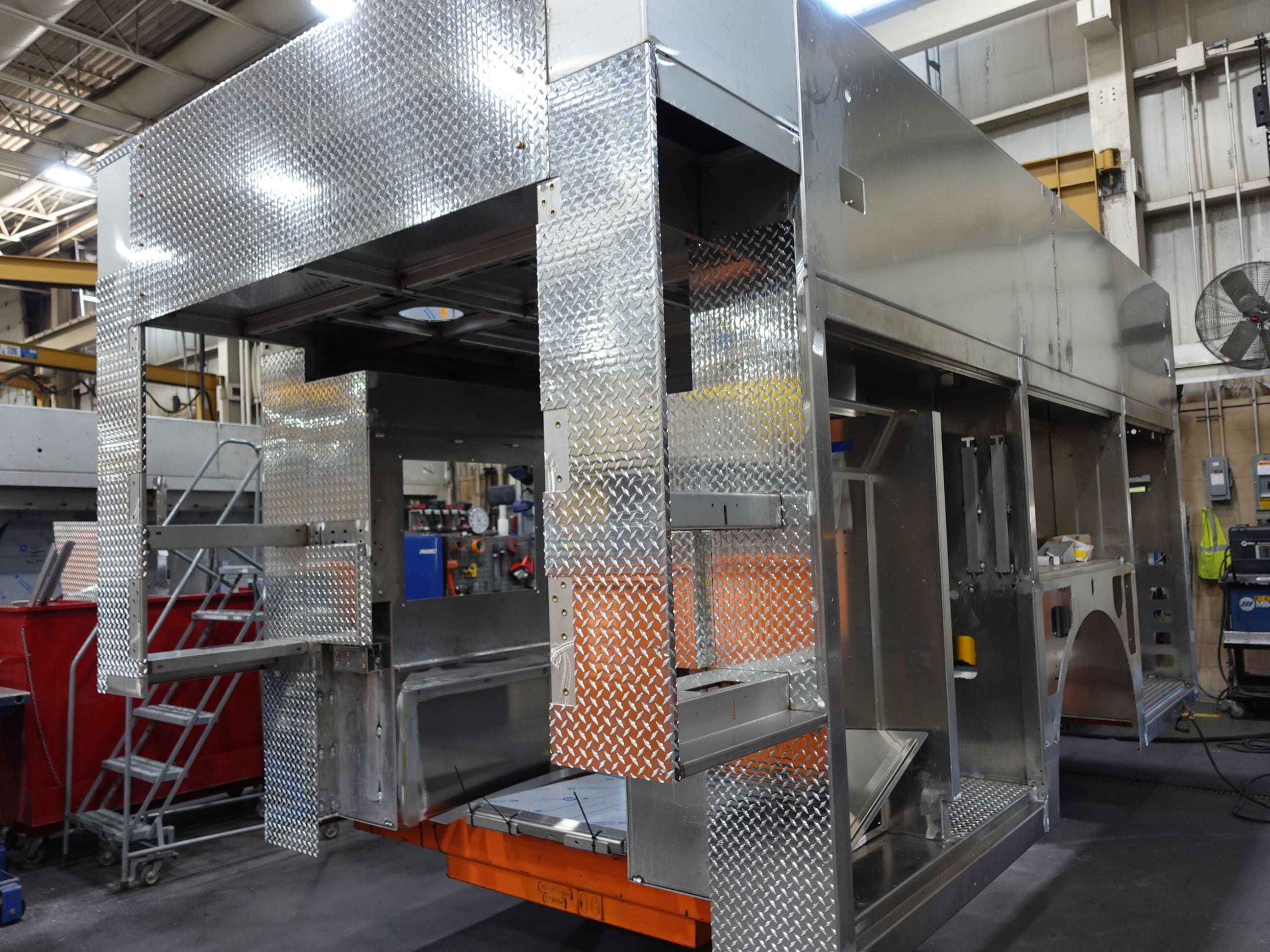

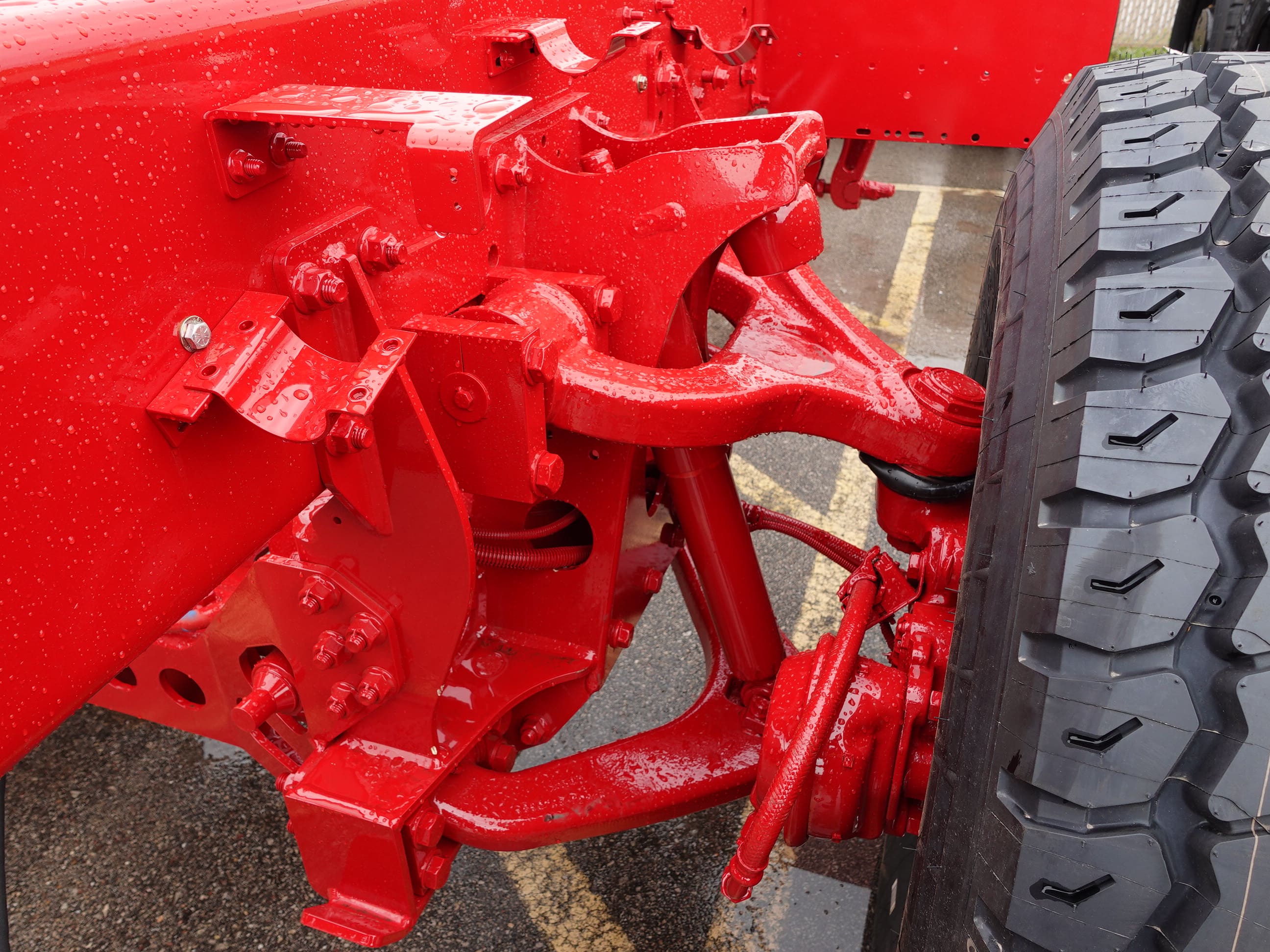

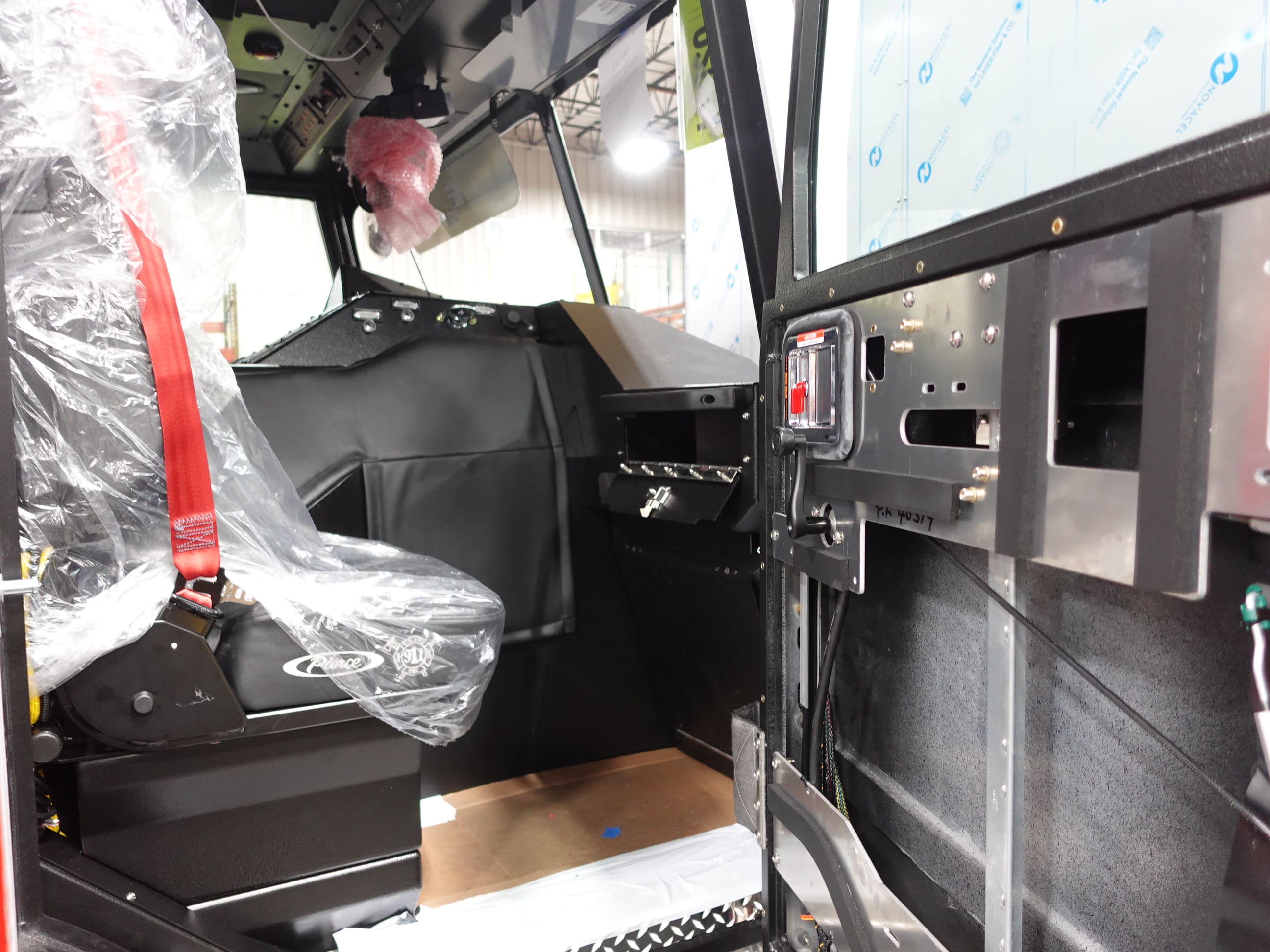

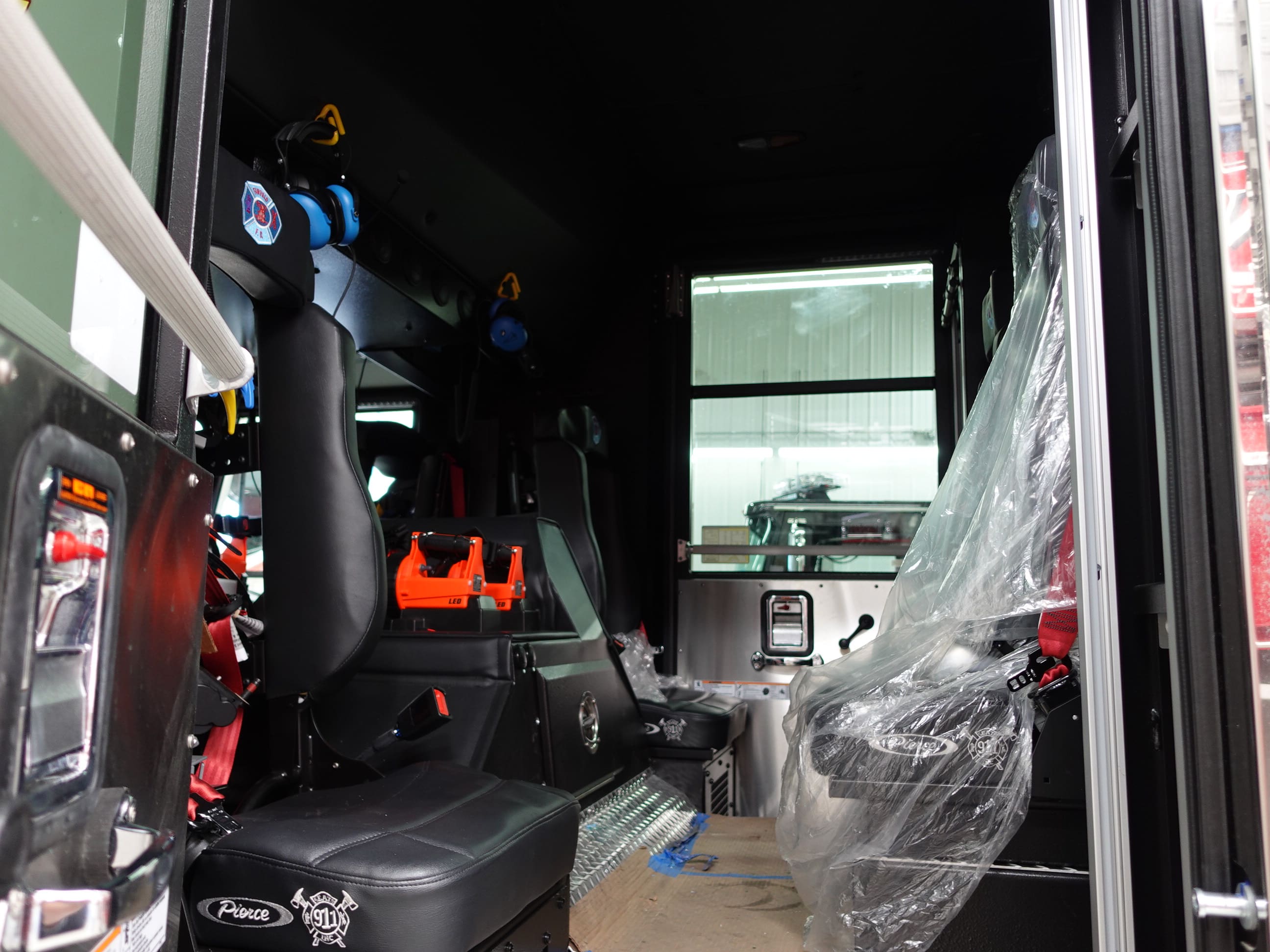

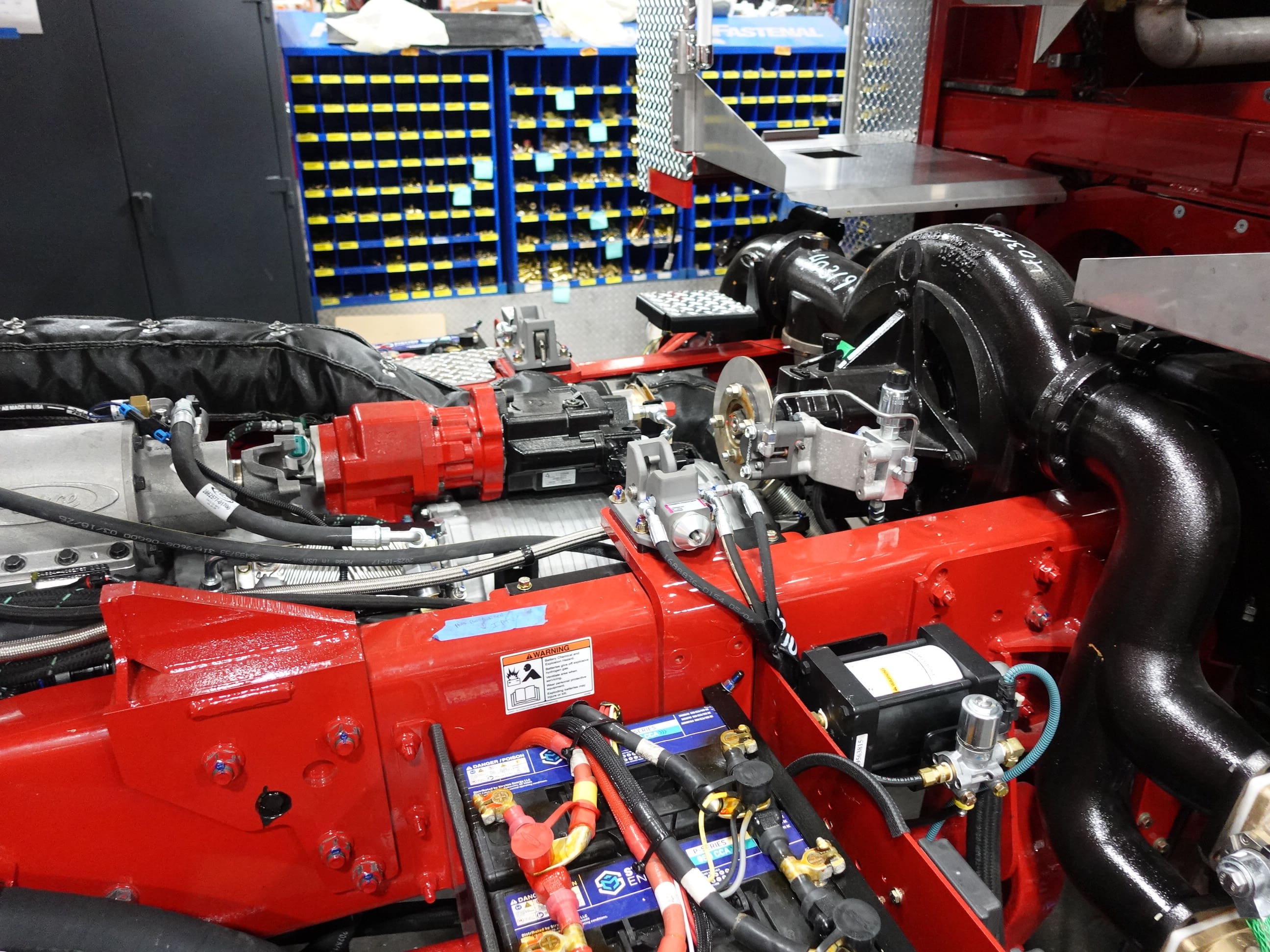

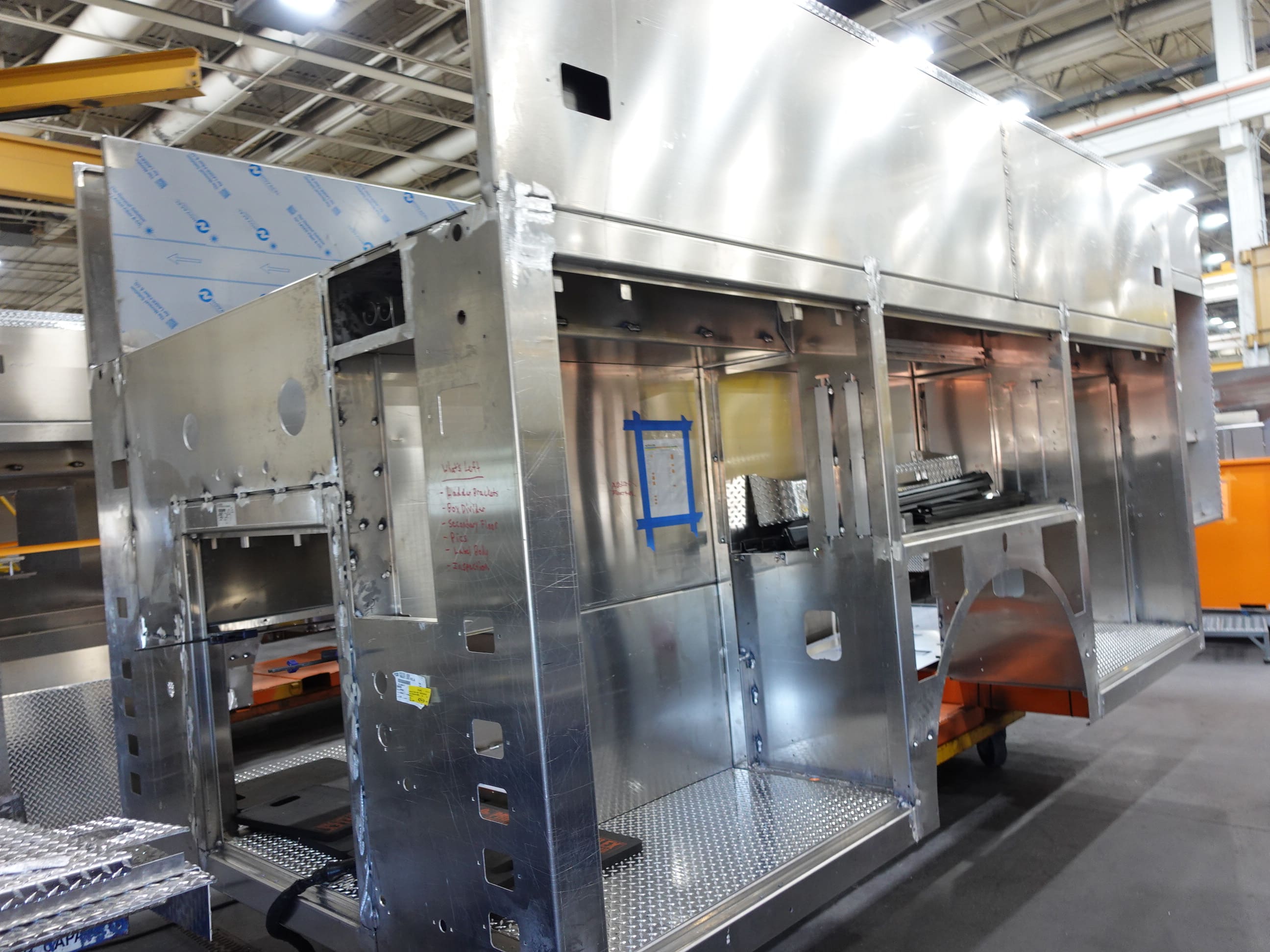

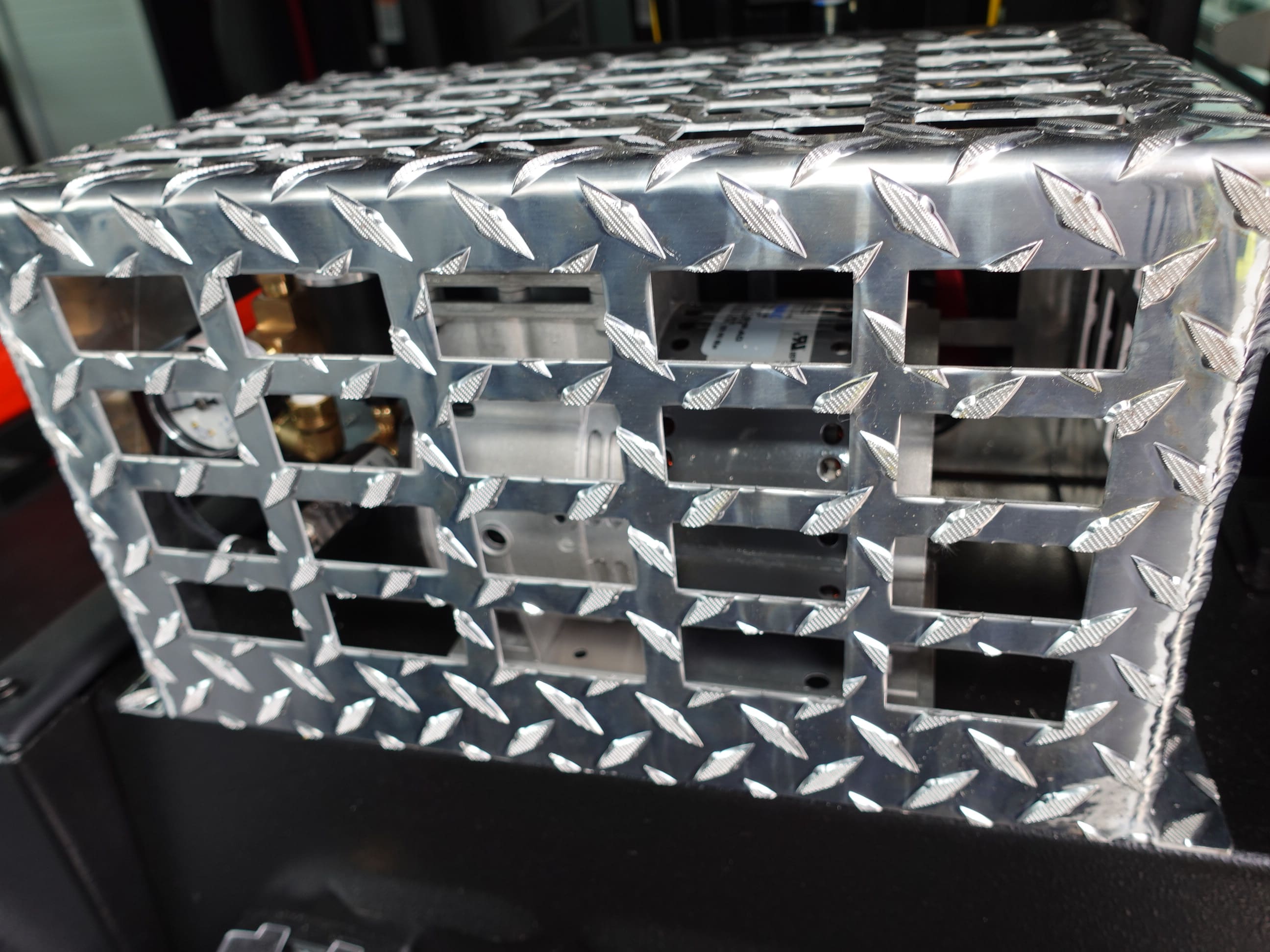

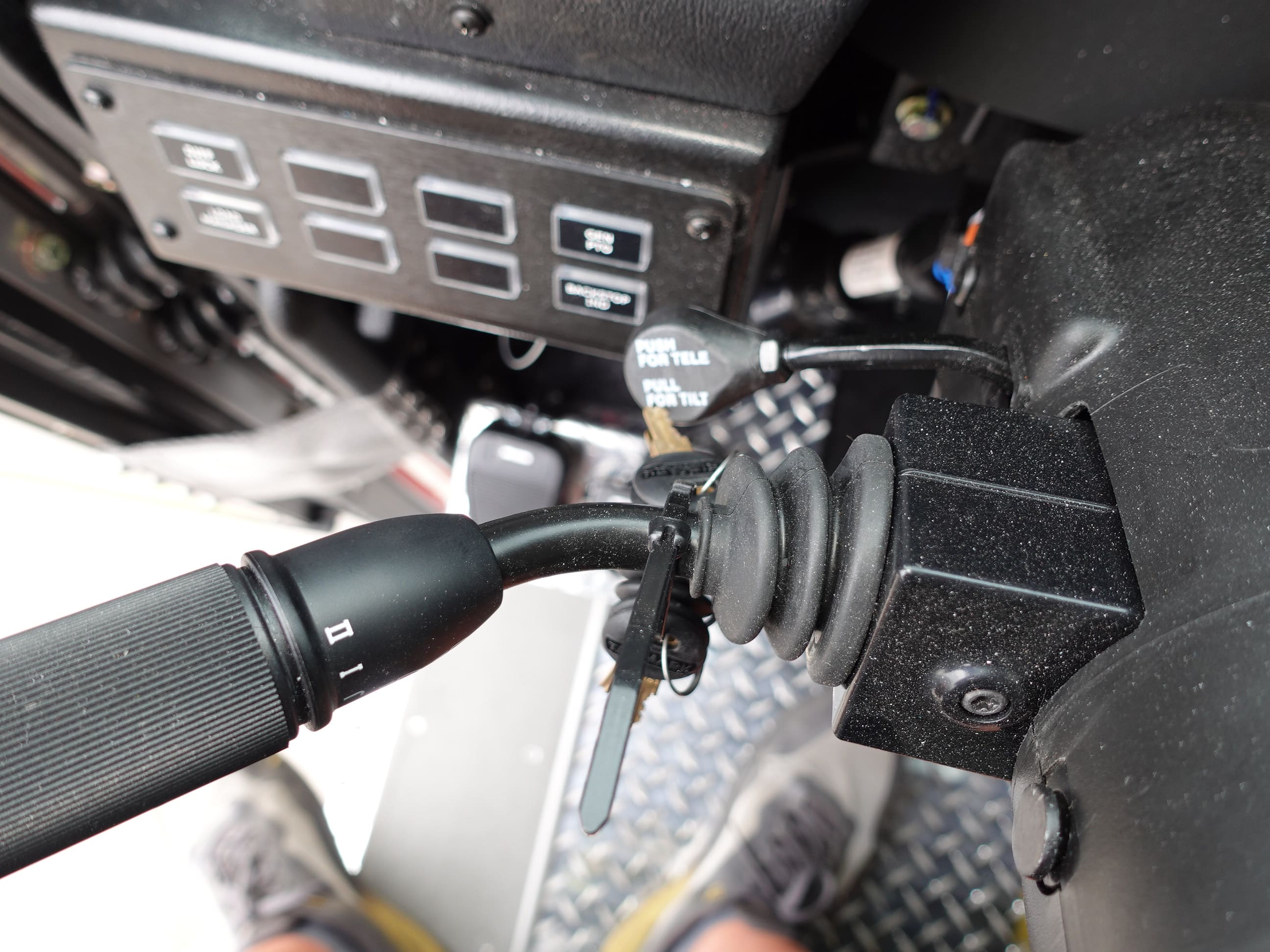

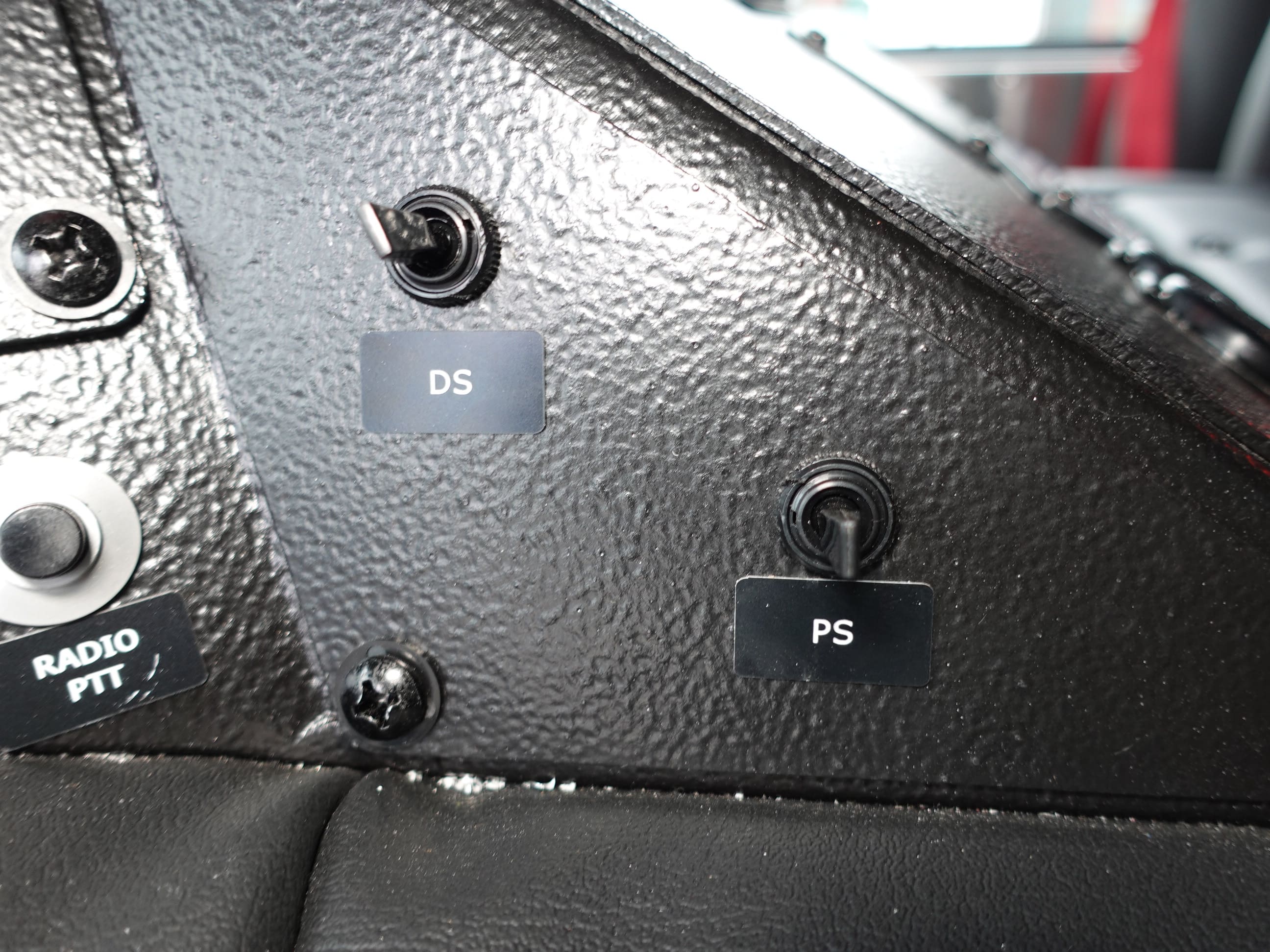

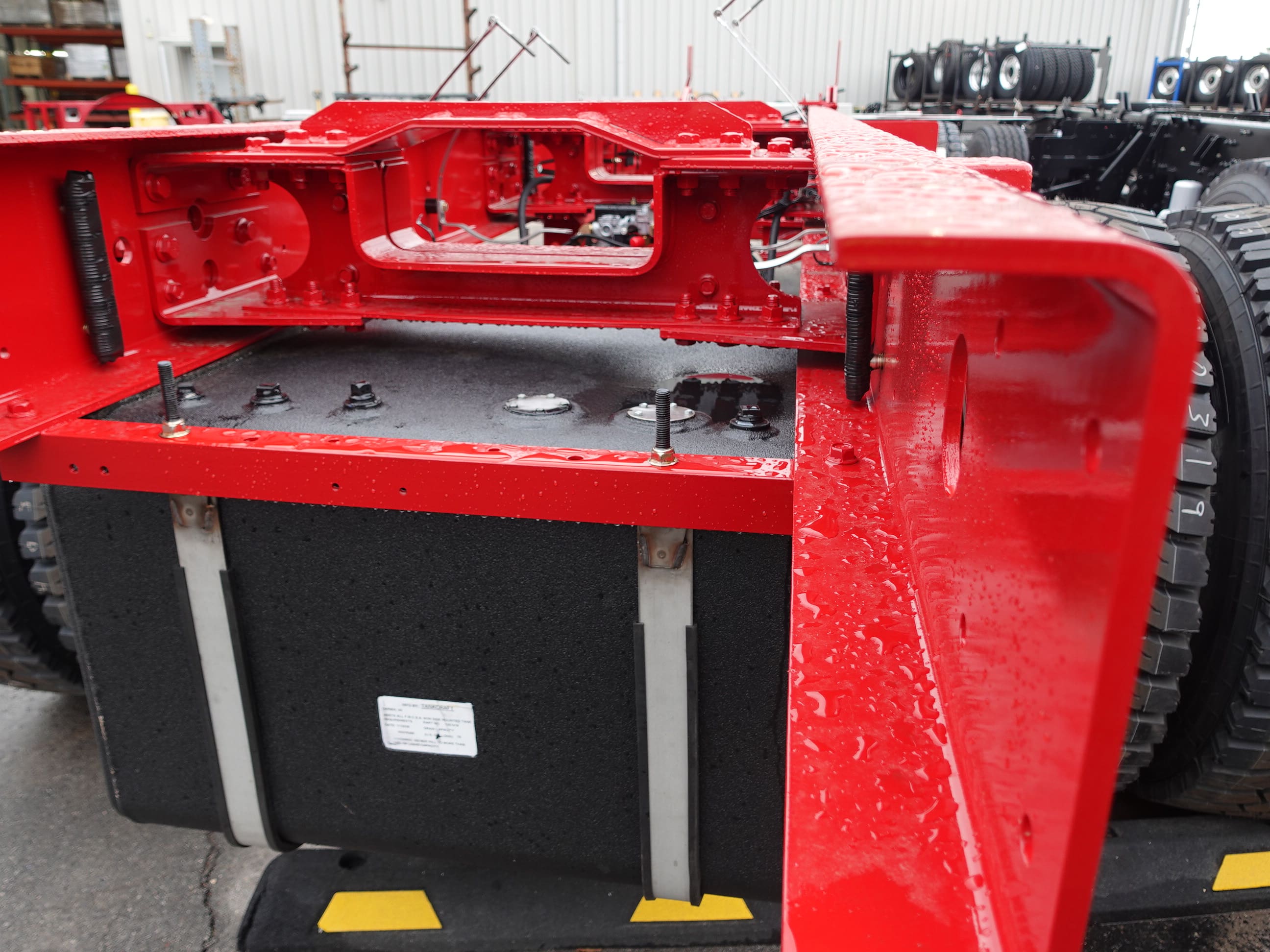

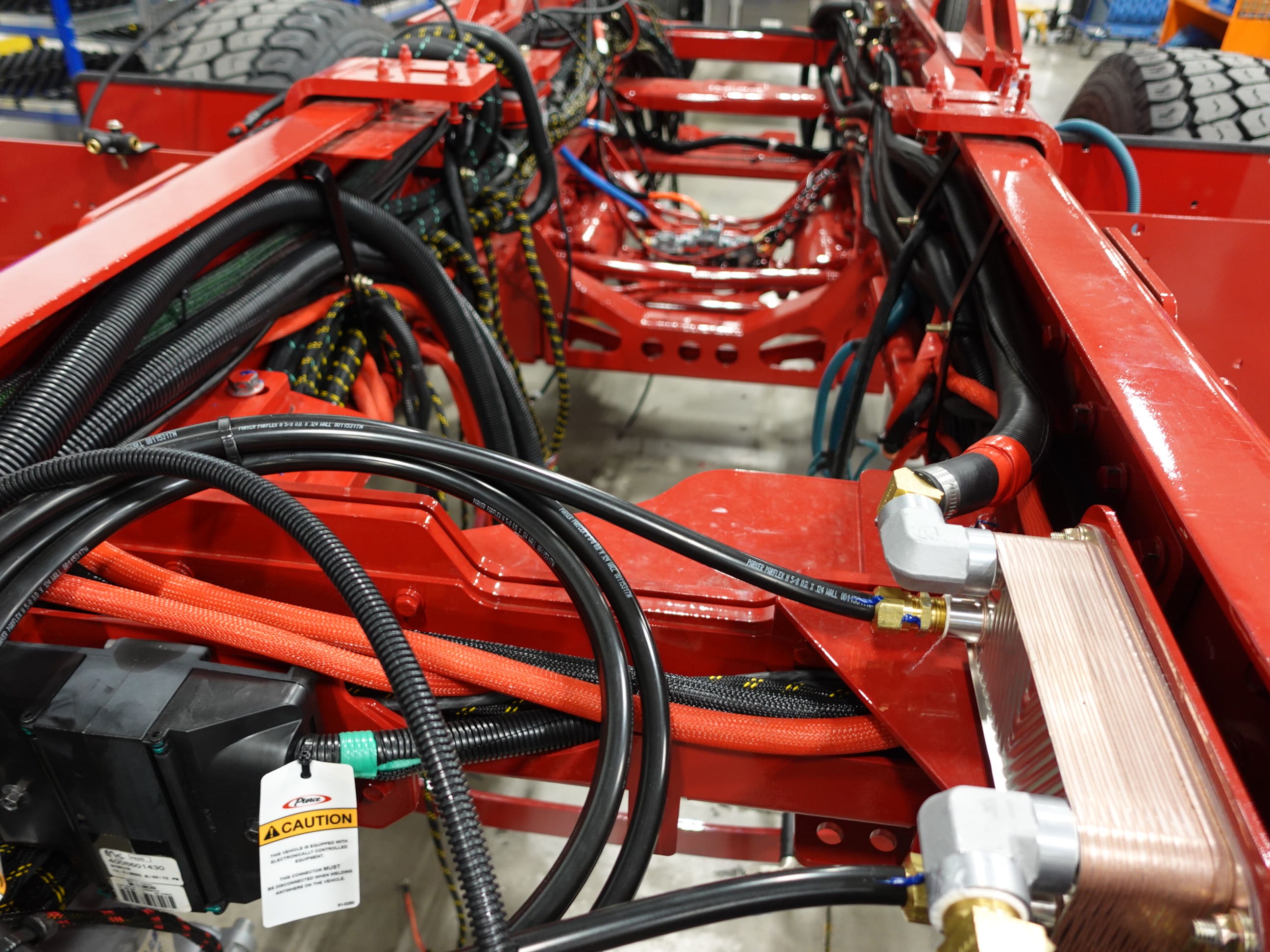

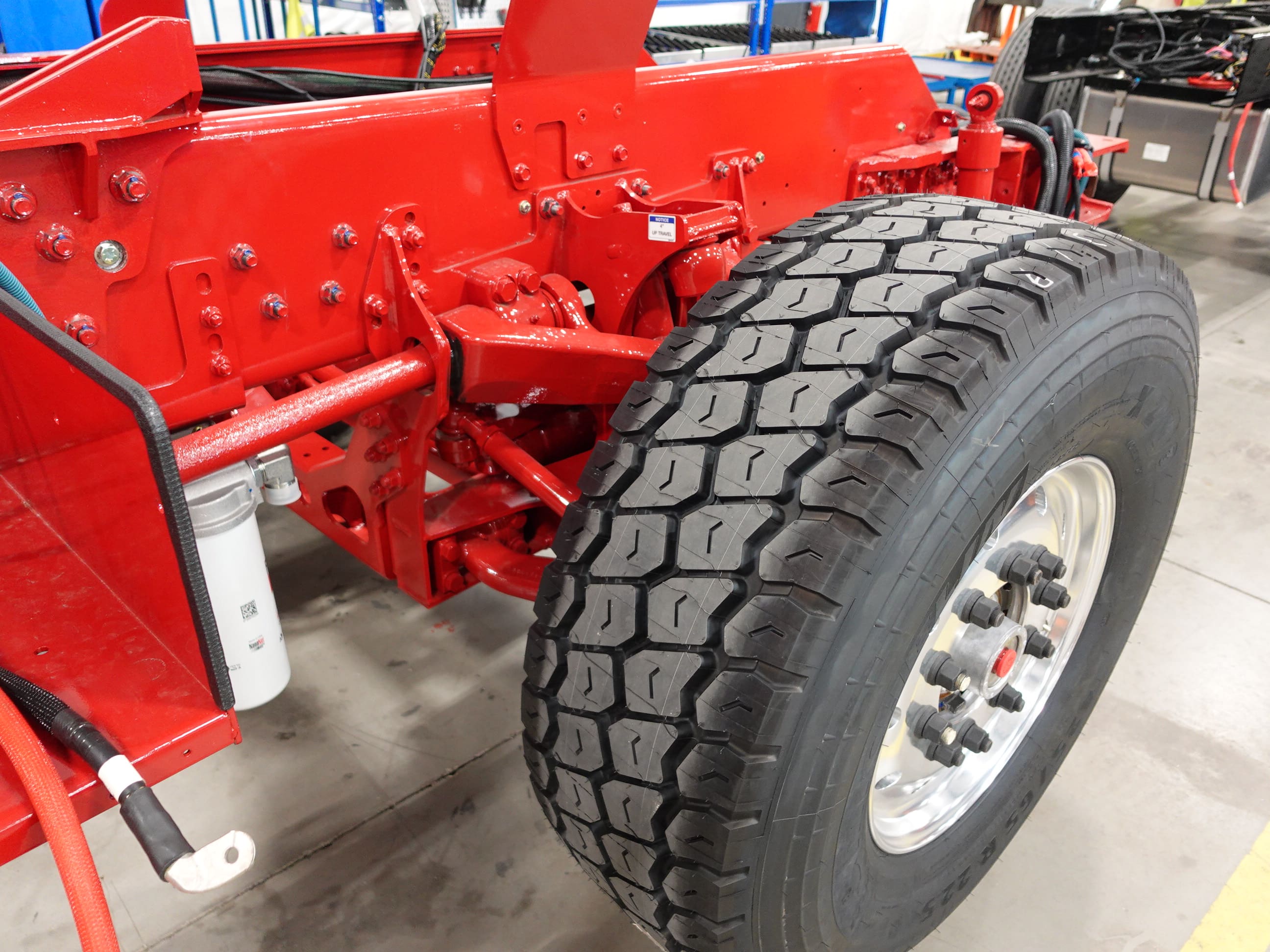

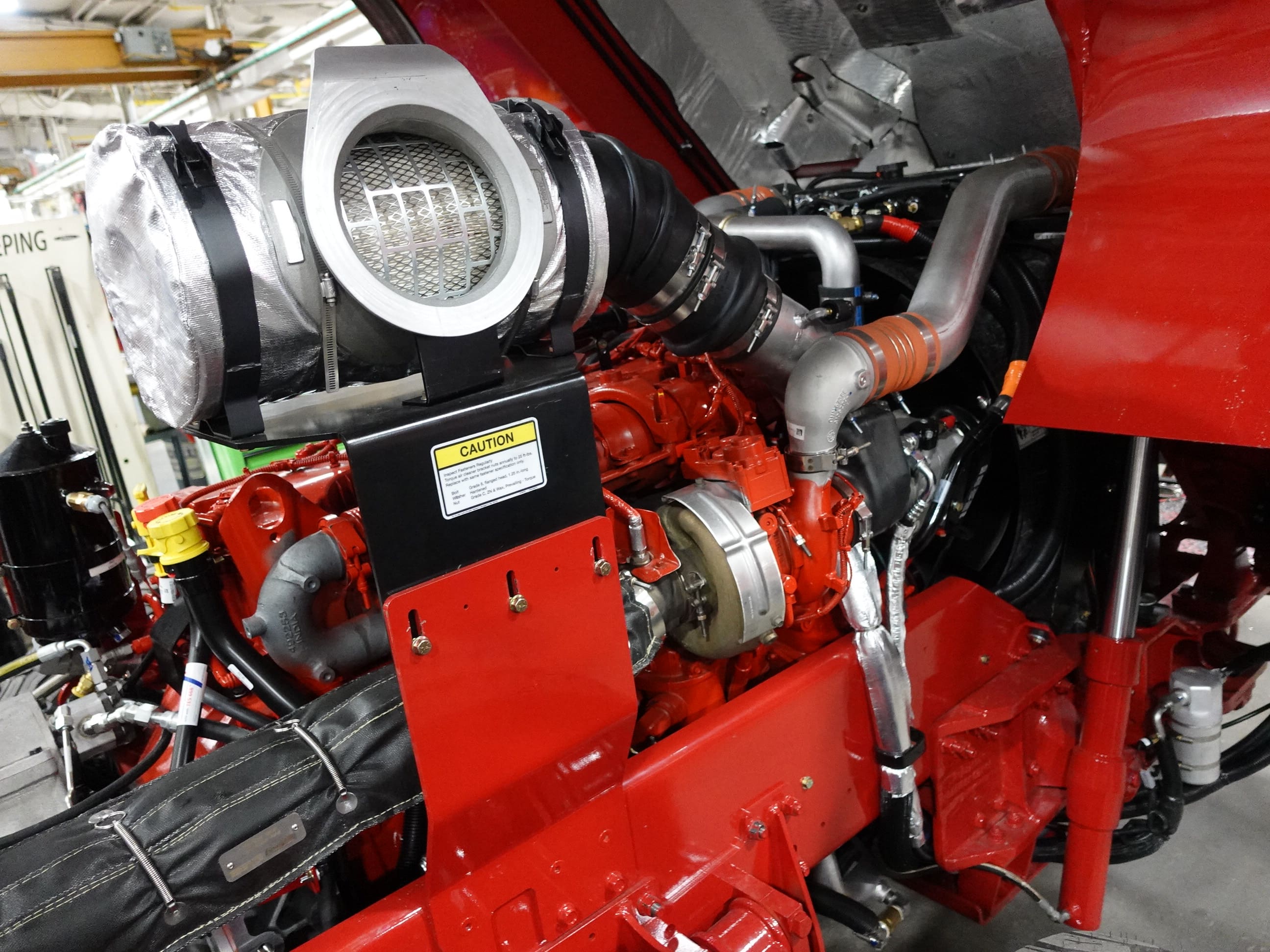

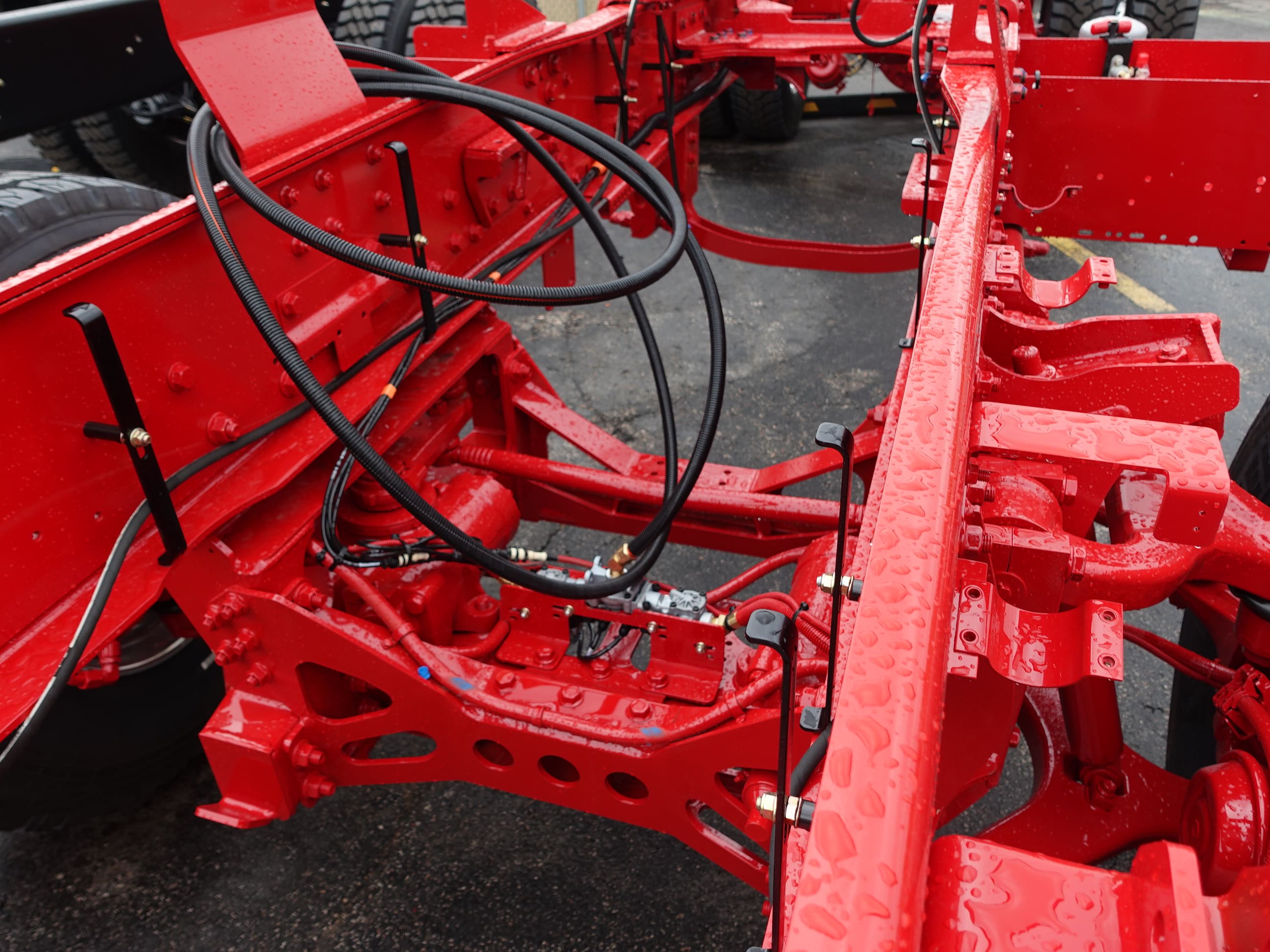

the frame at the start of initial apparatus assembly.

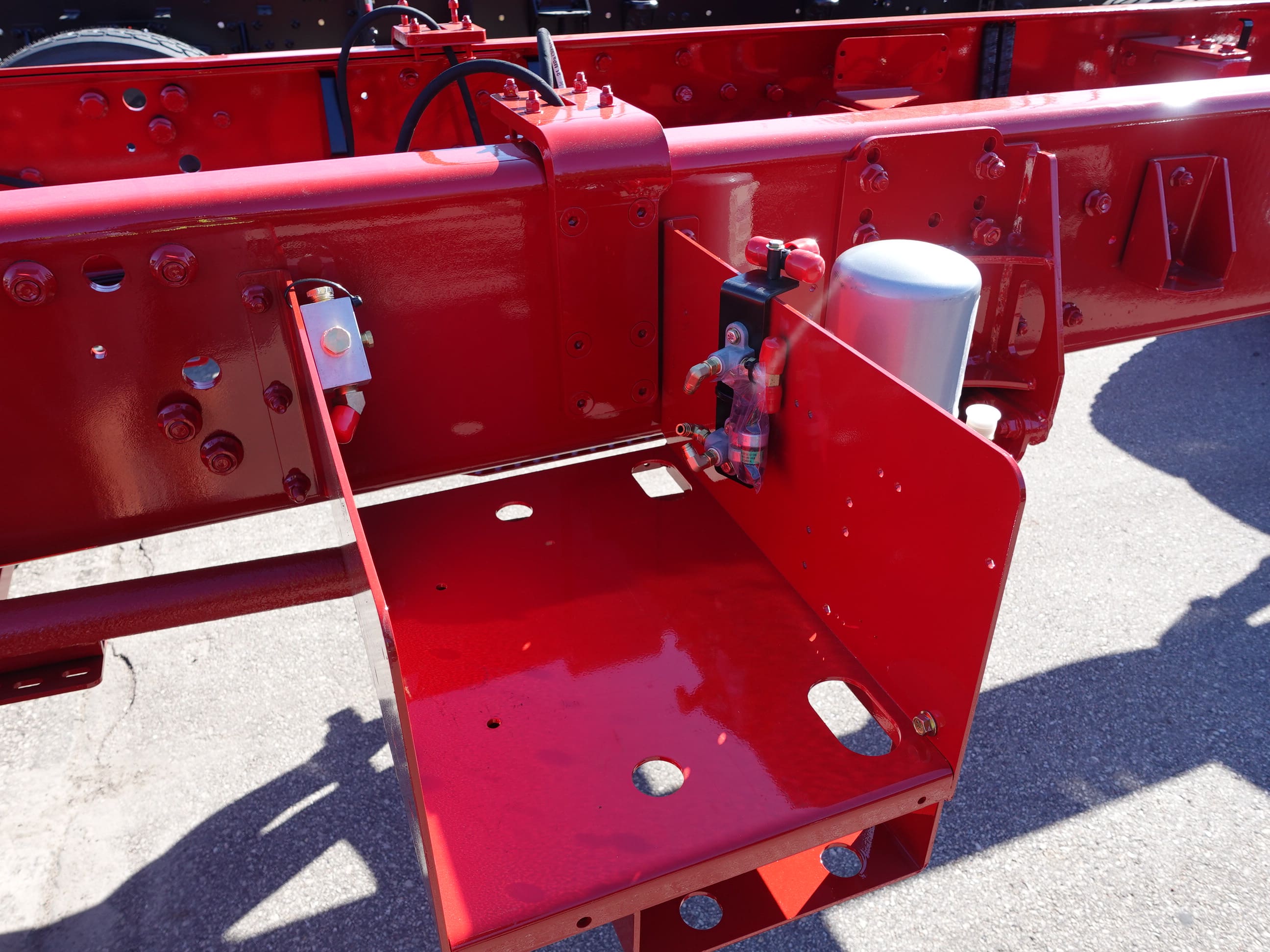

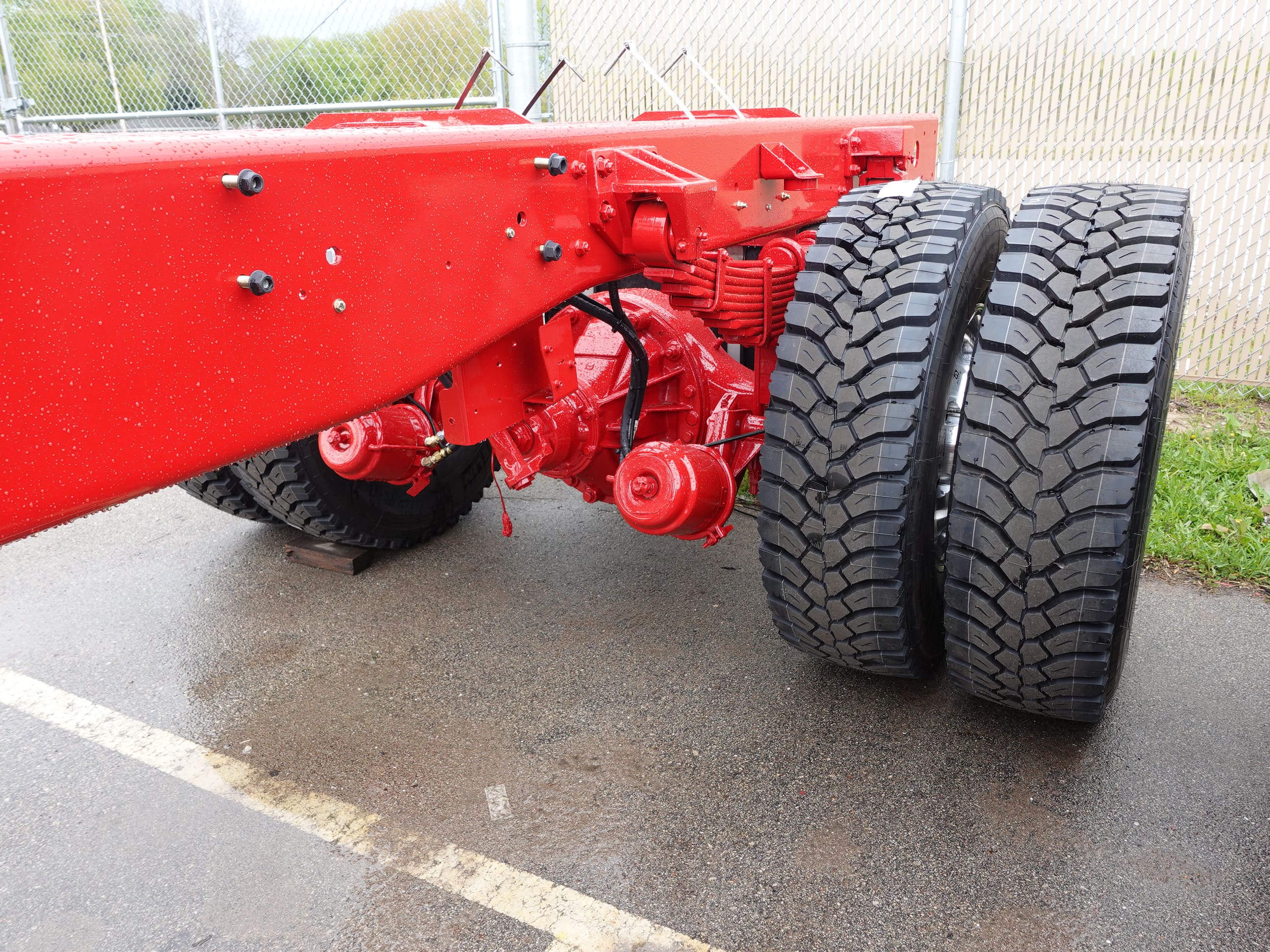

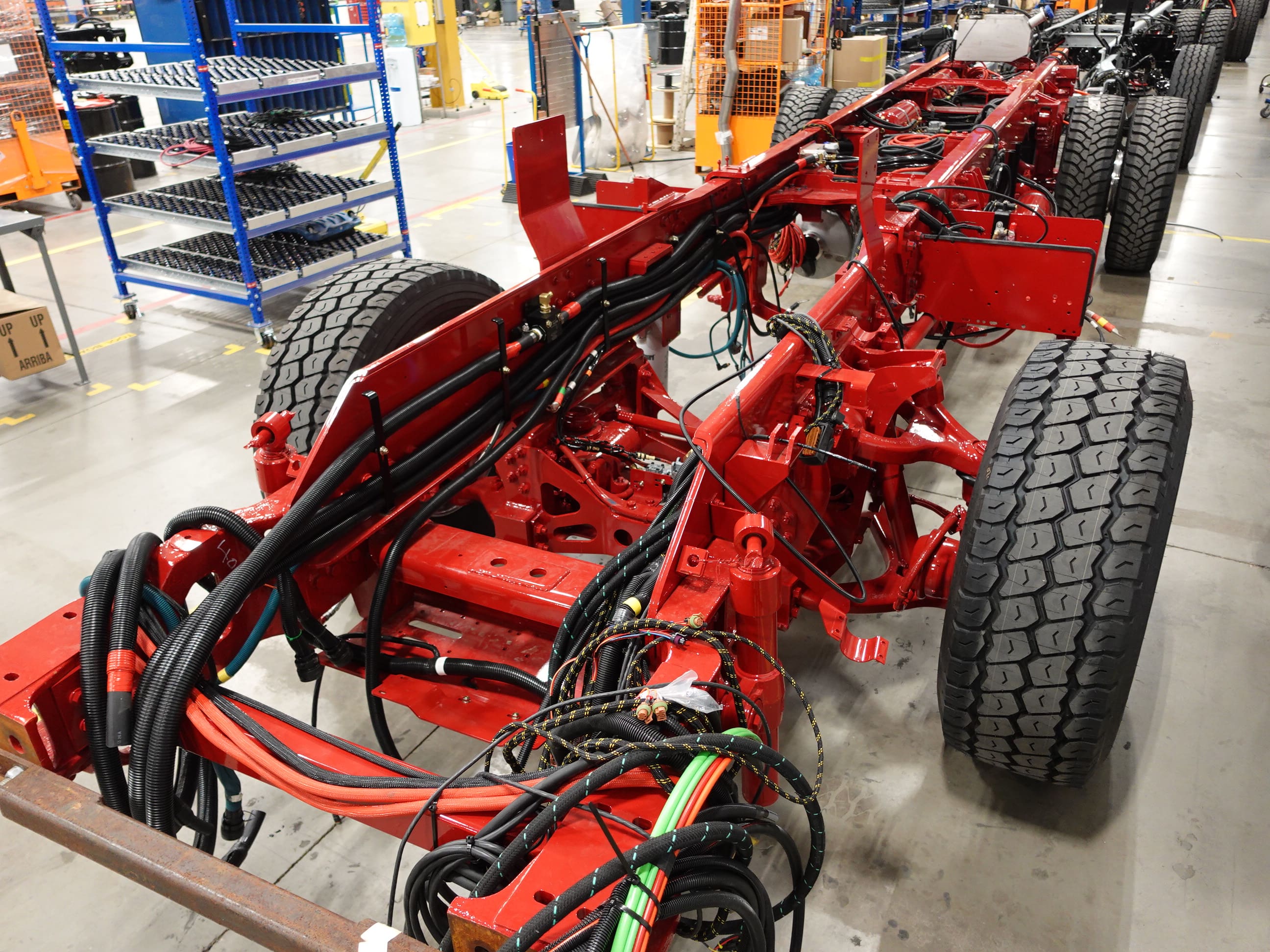

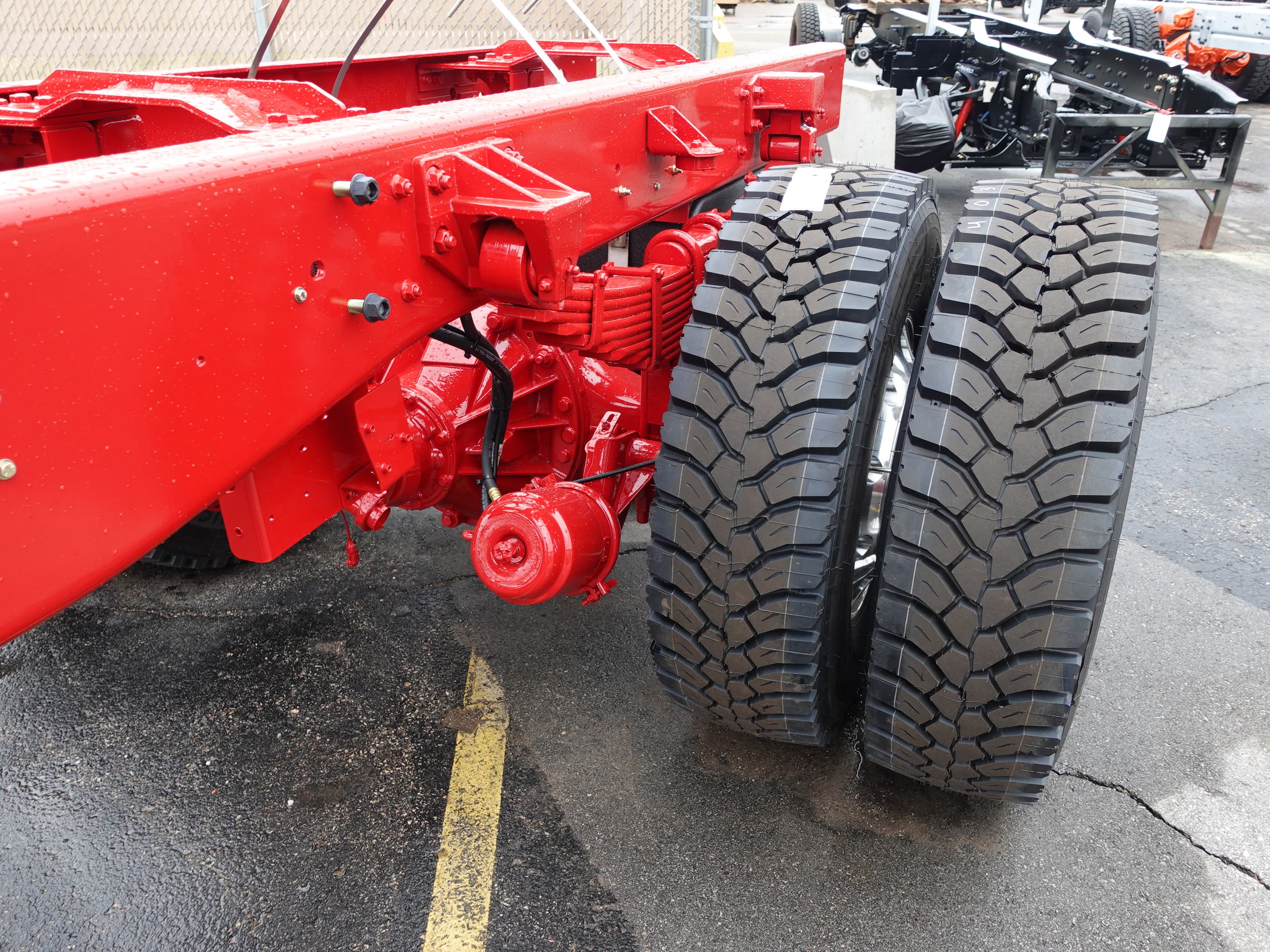

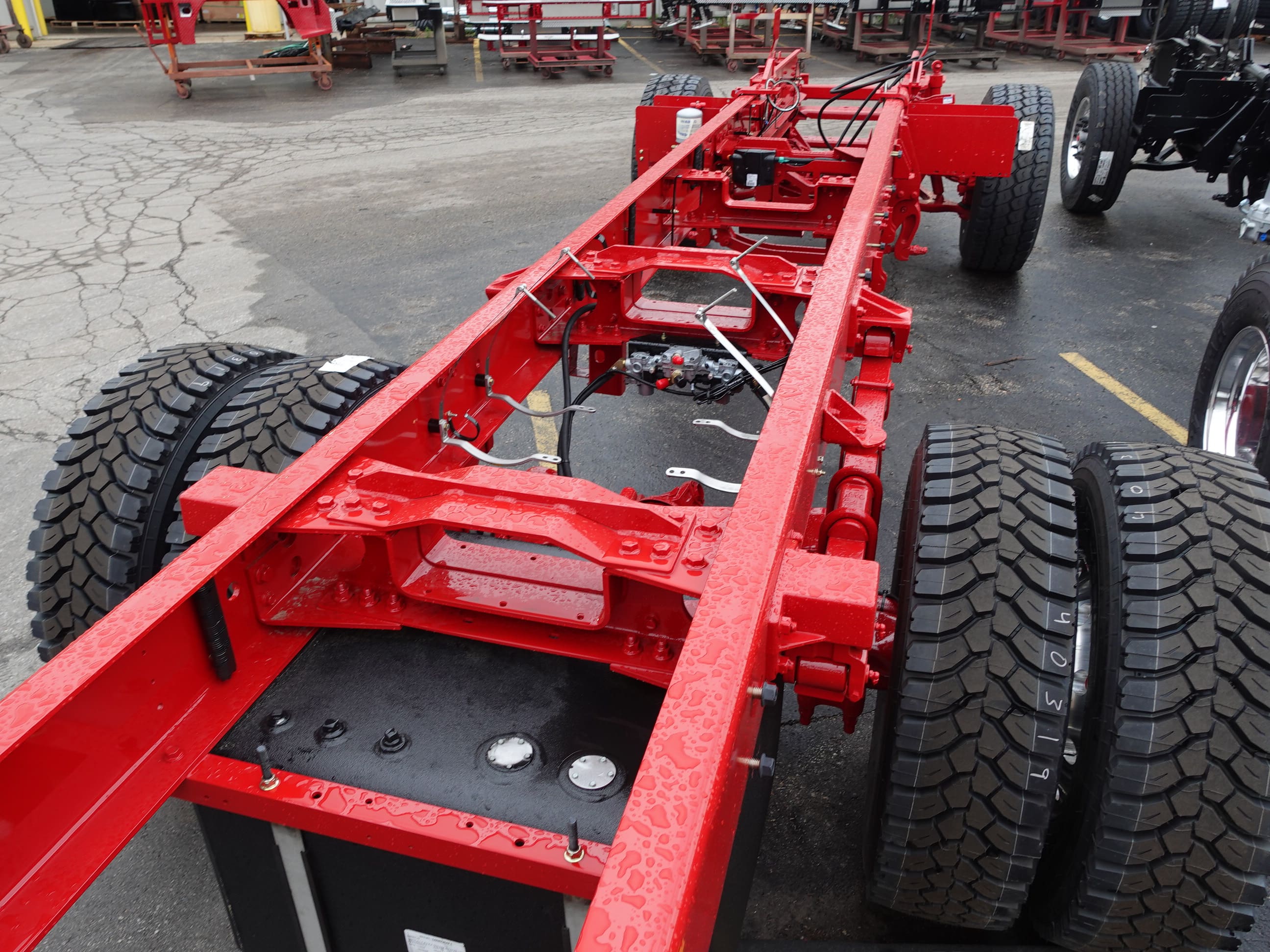

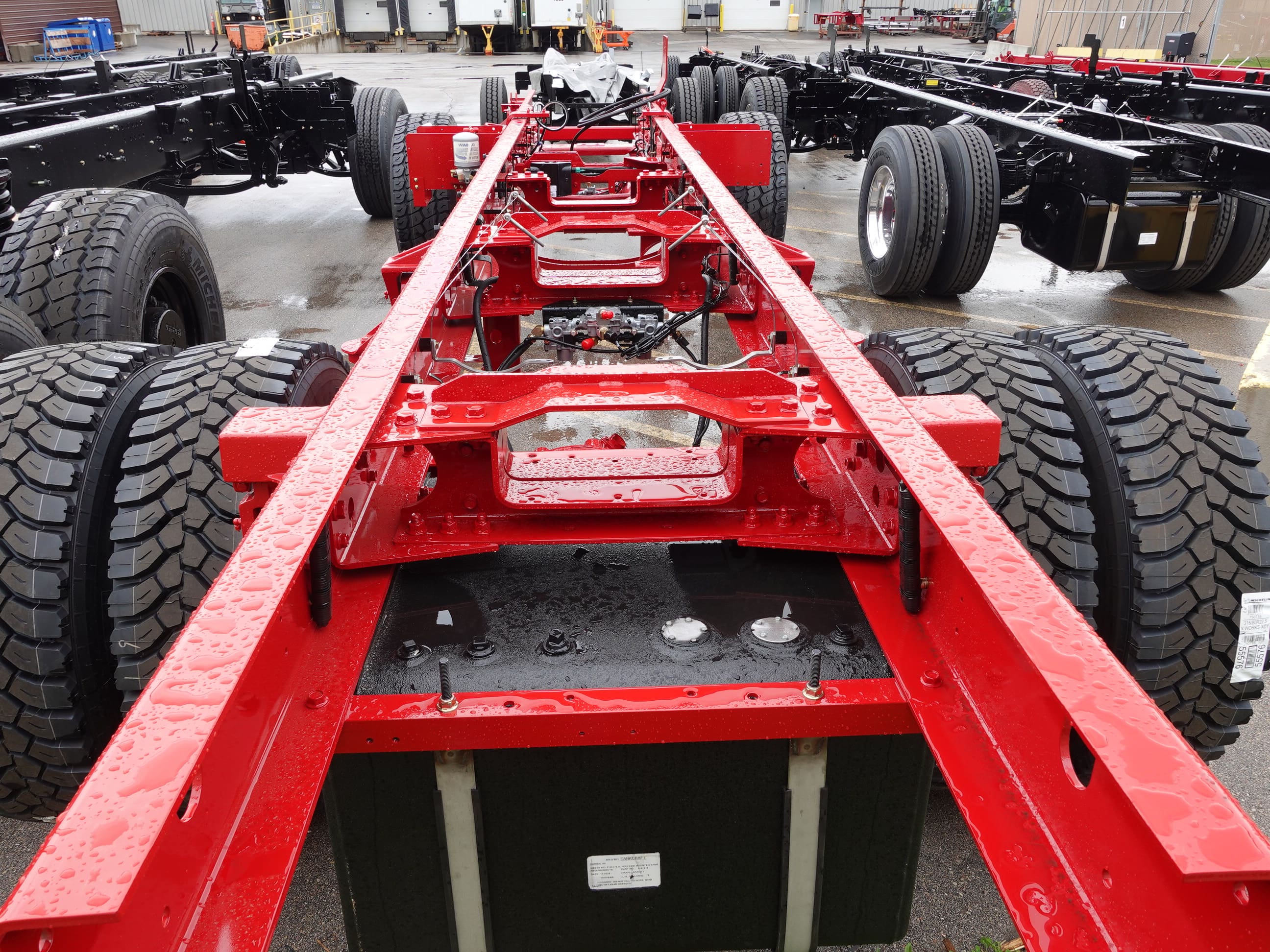

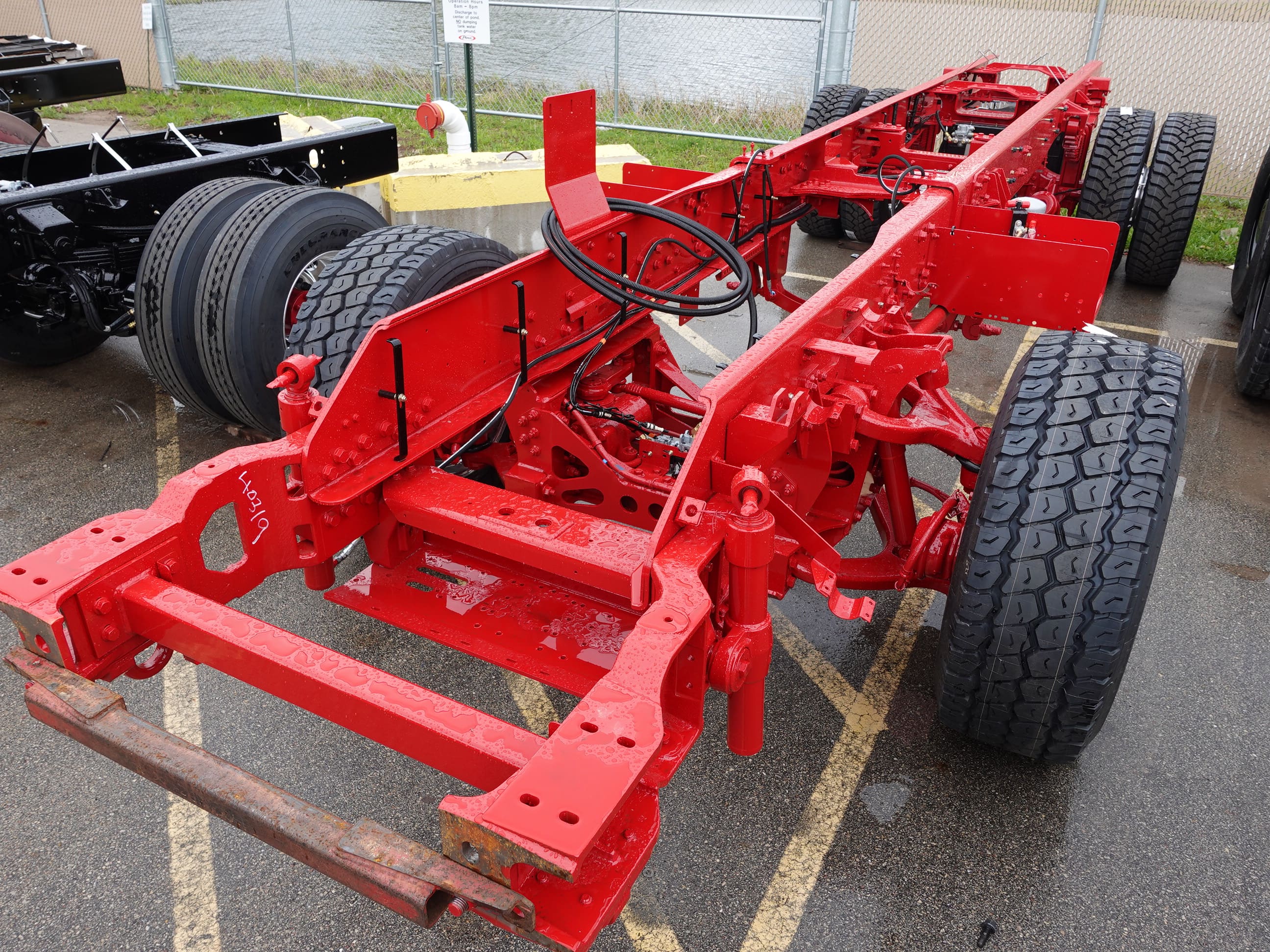

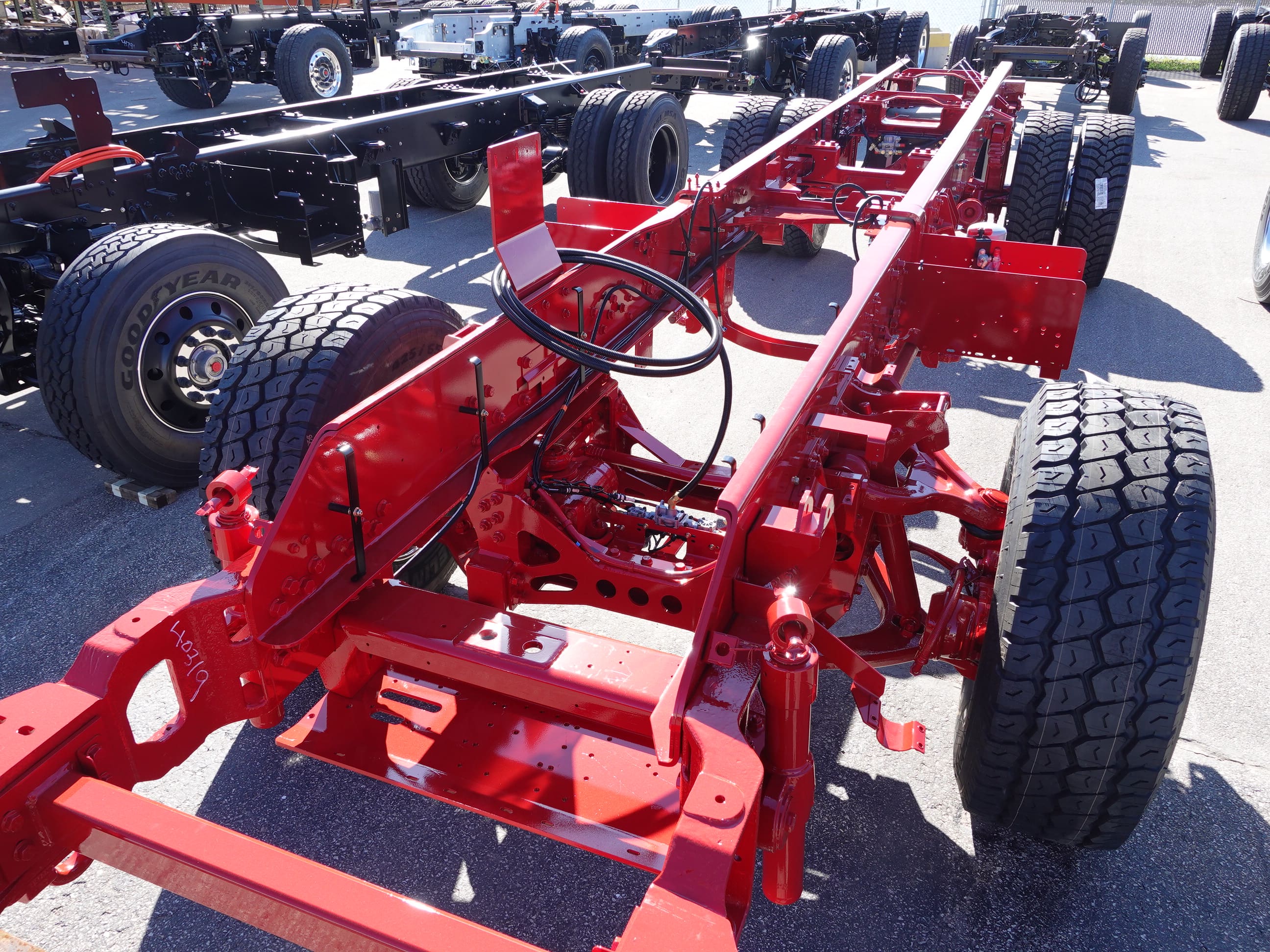

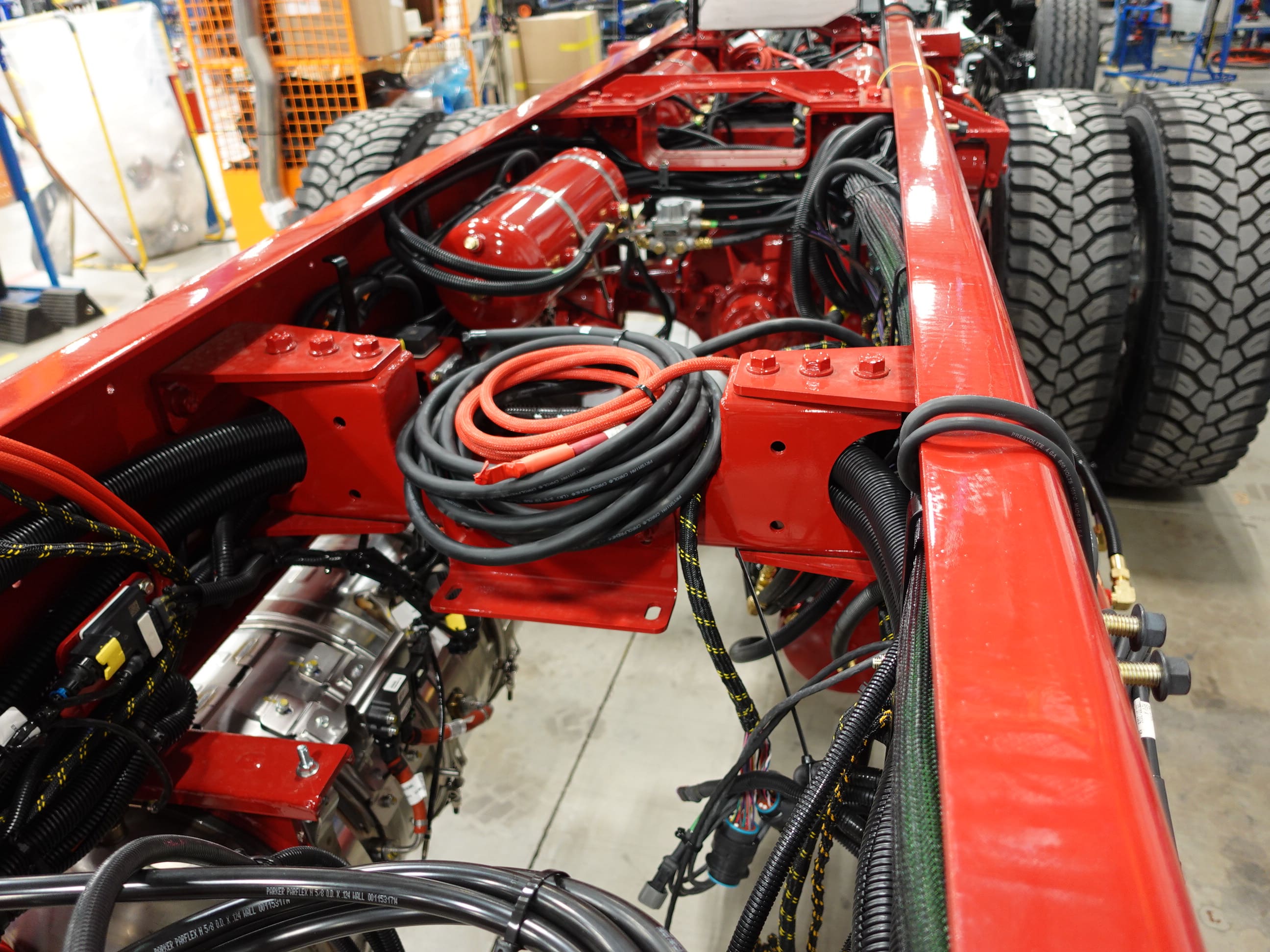

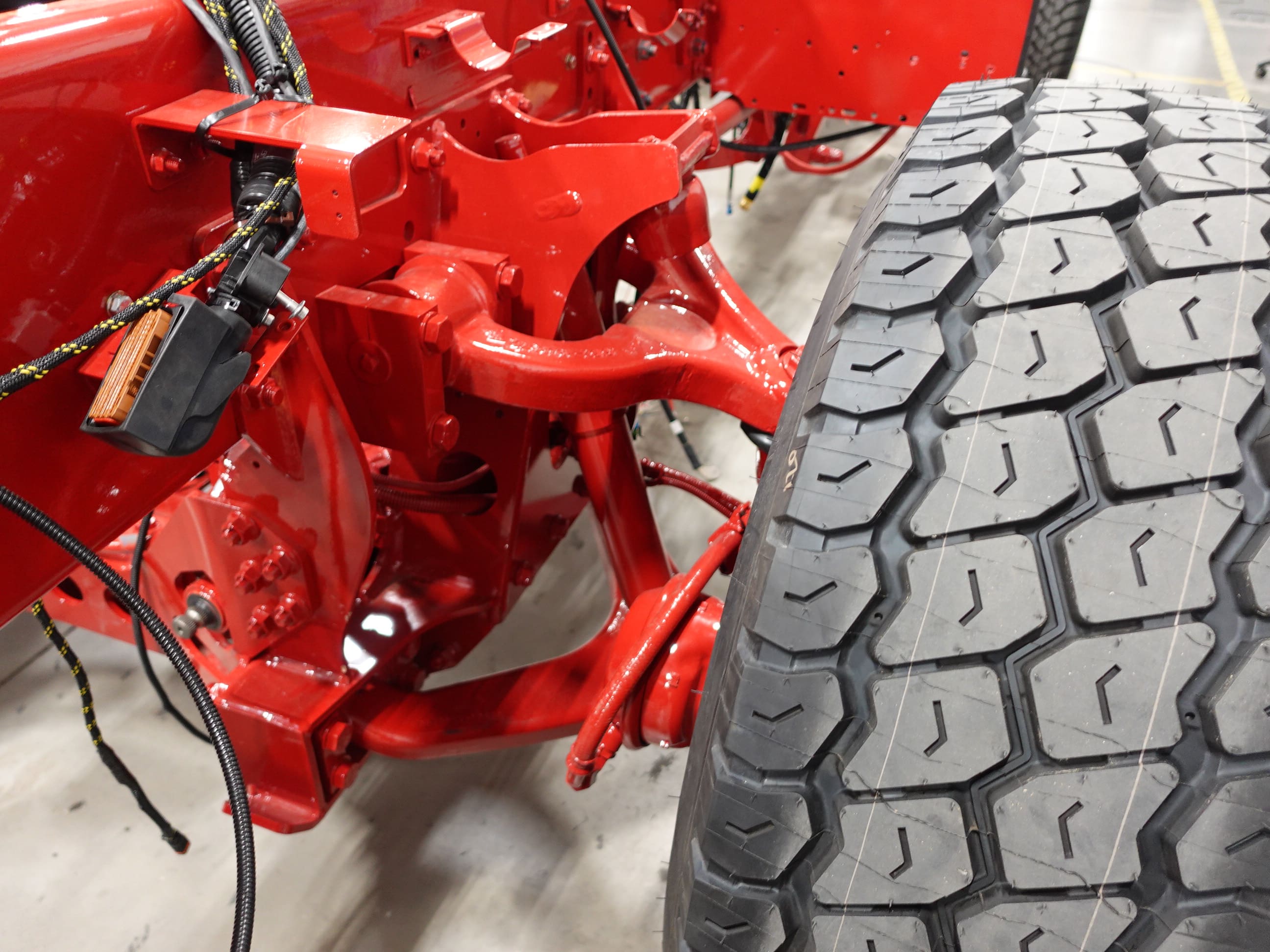

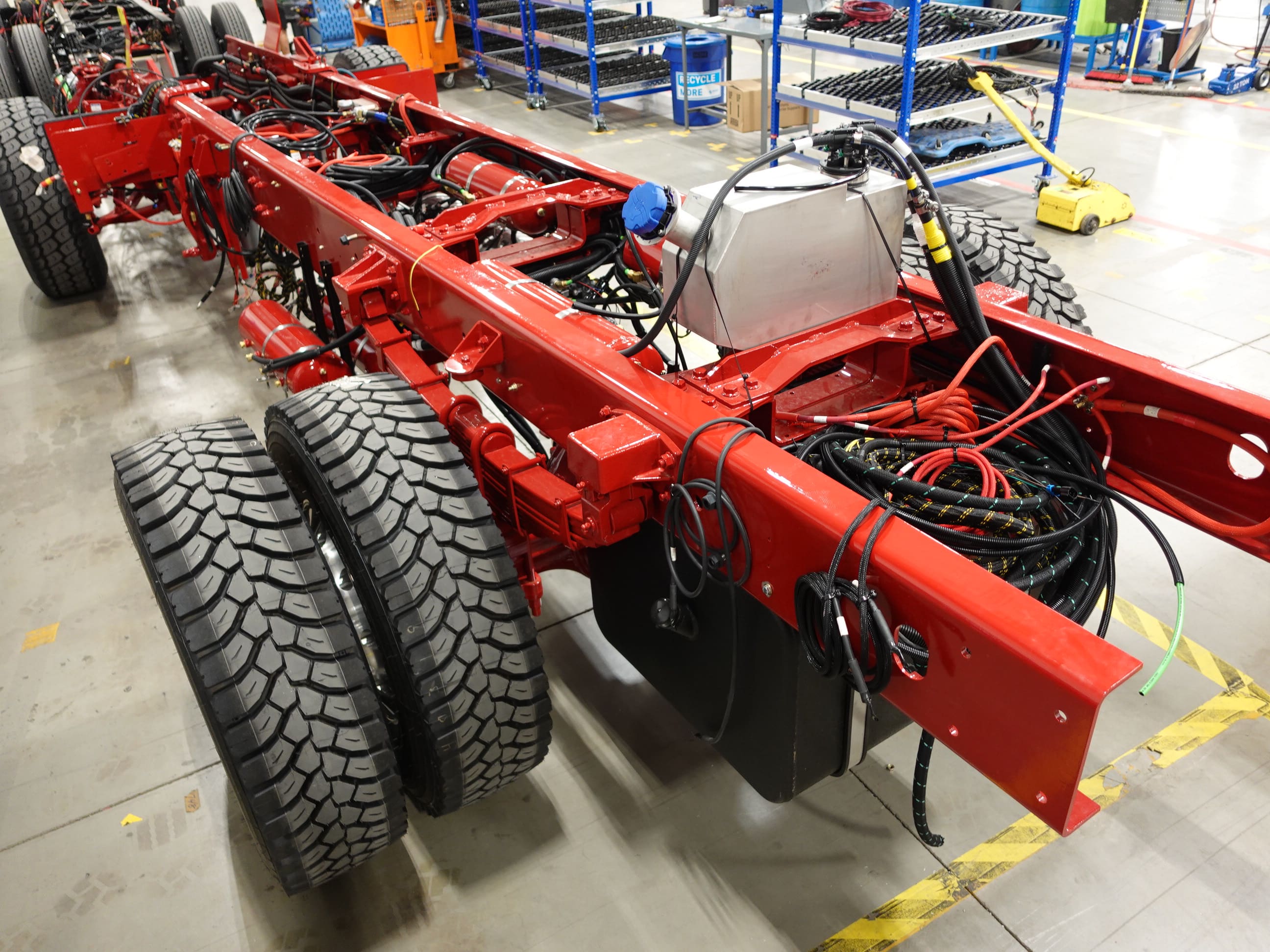

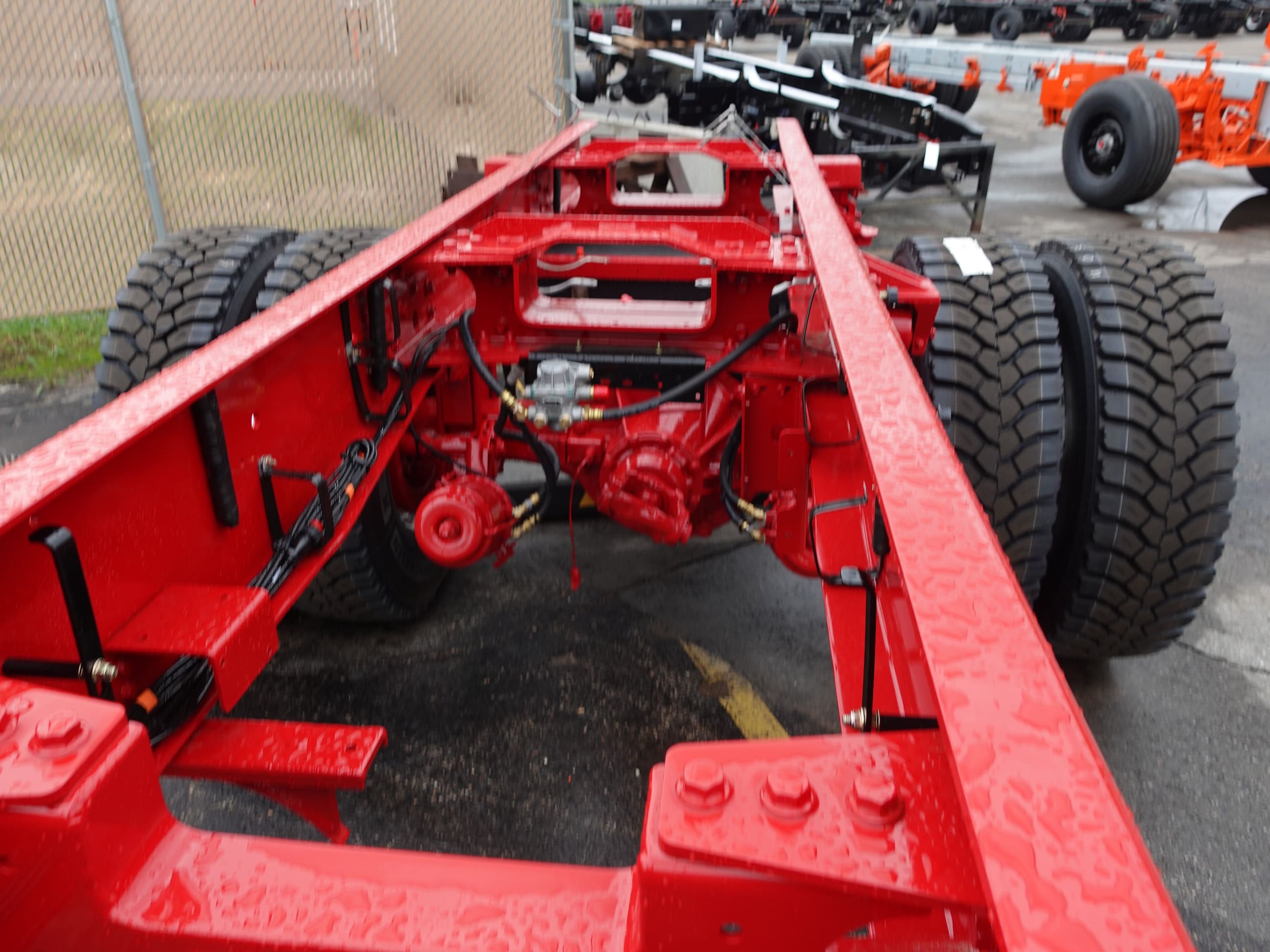

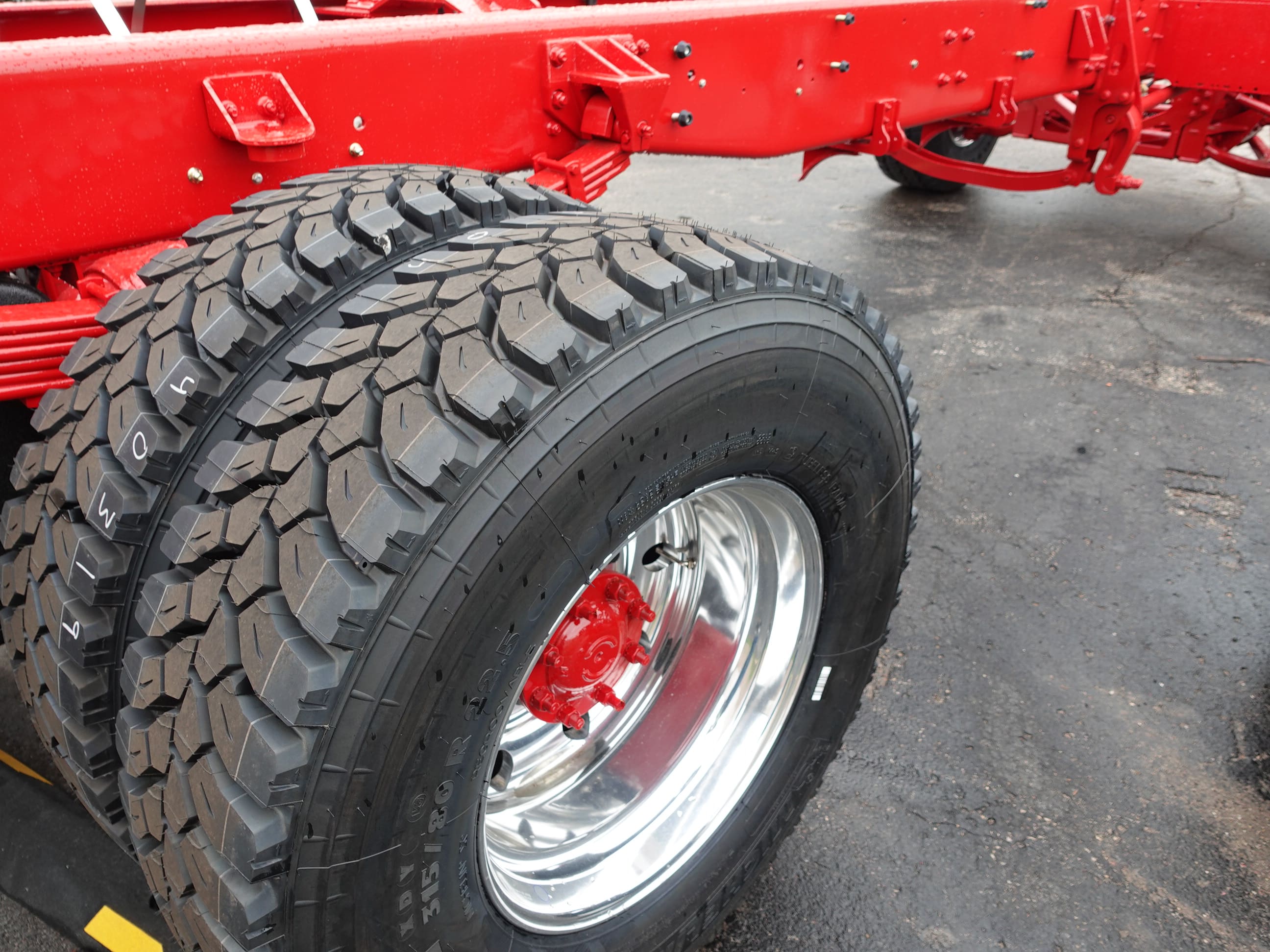

06-05-26

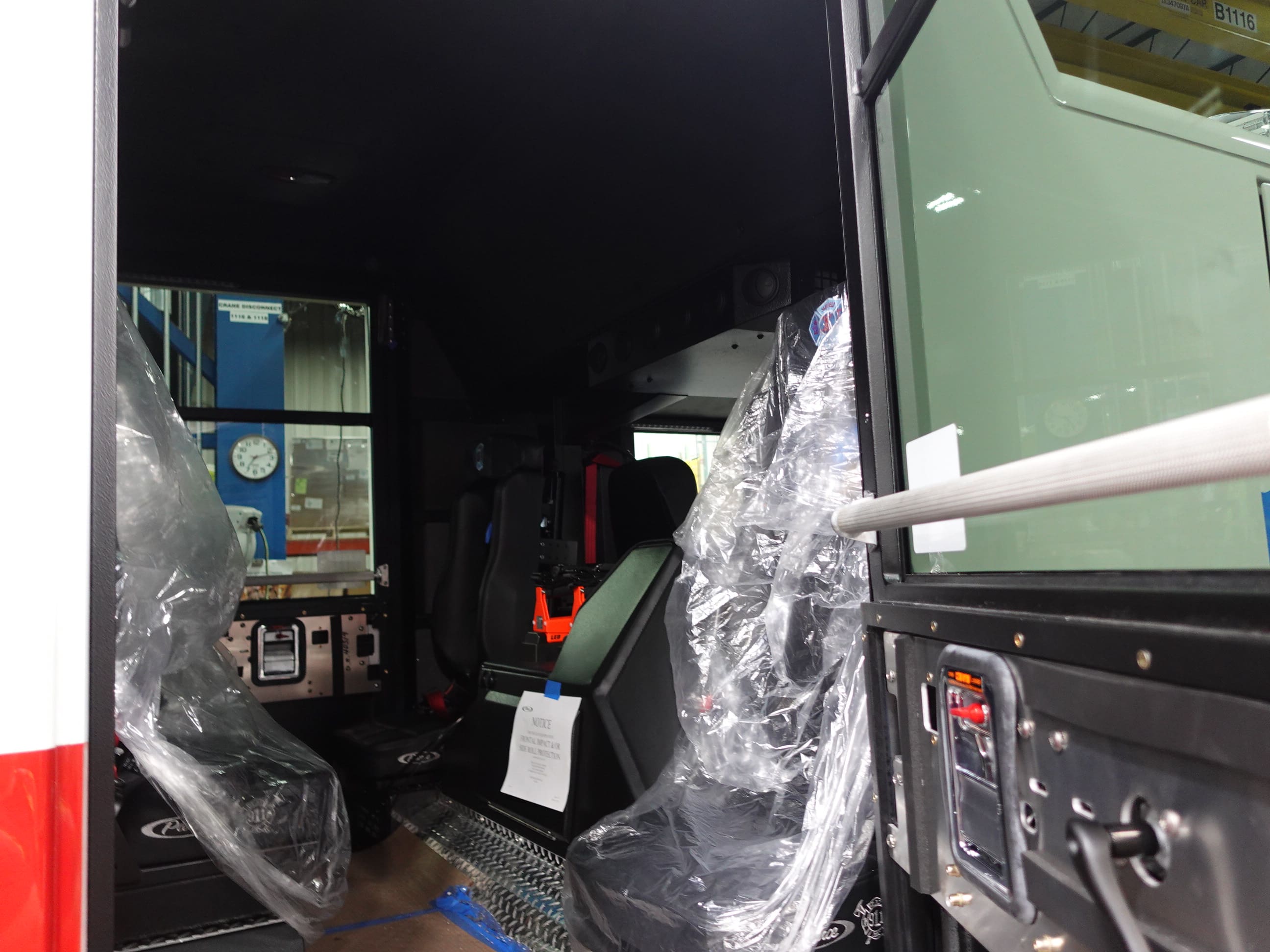

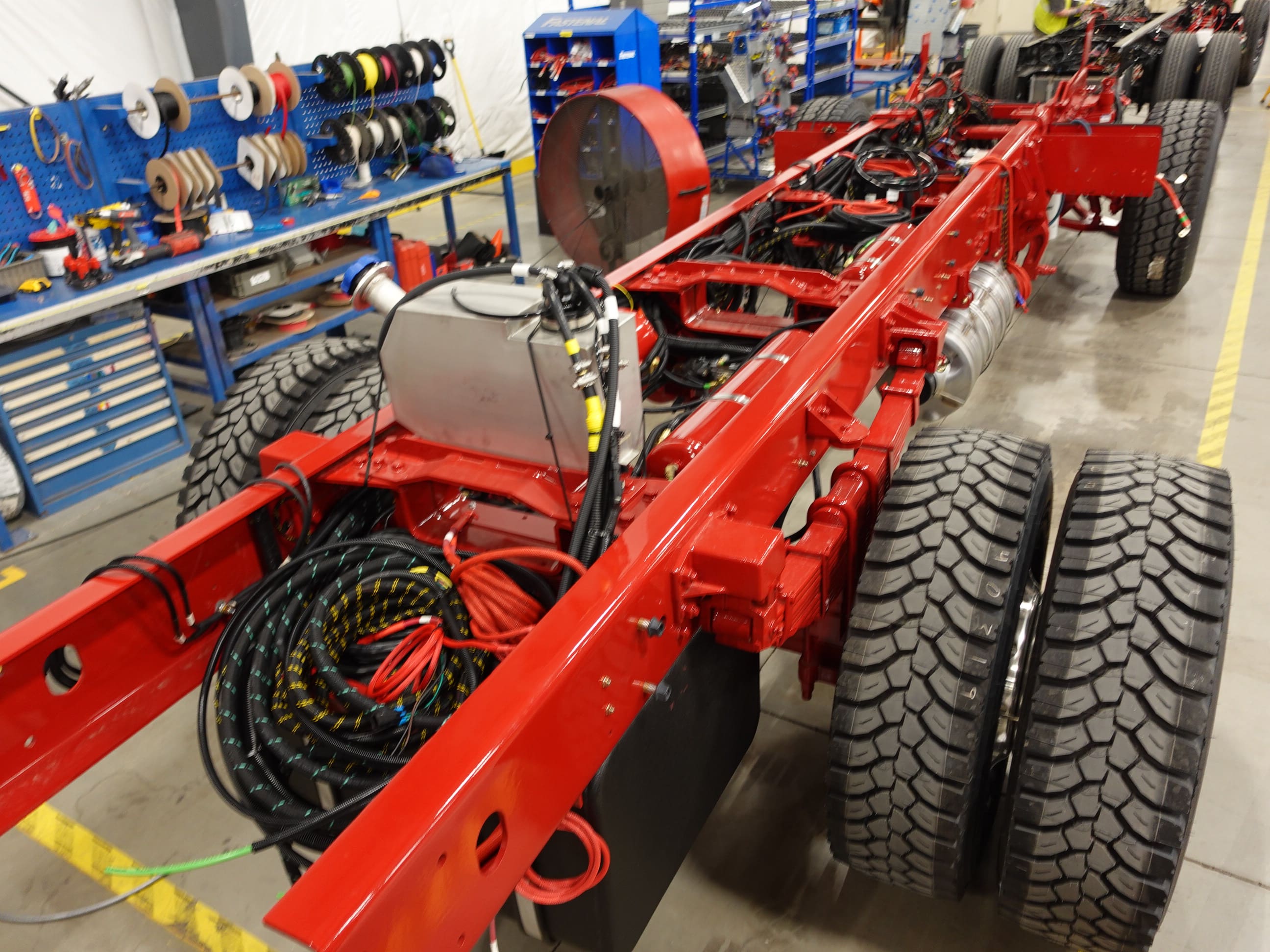

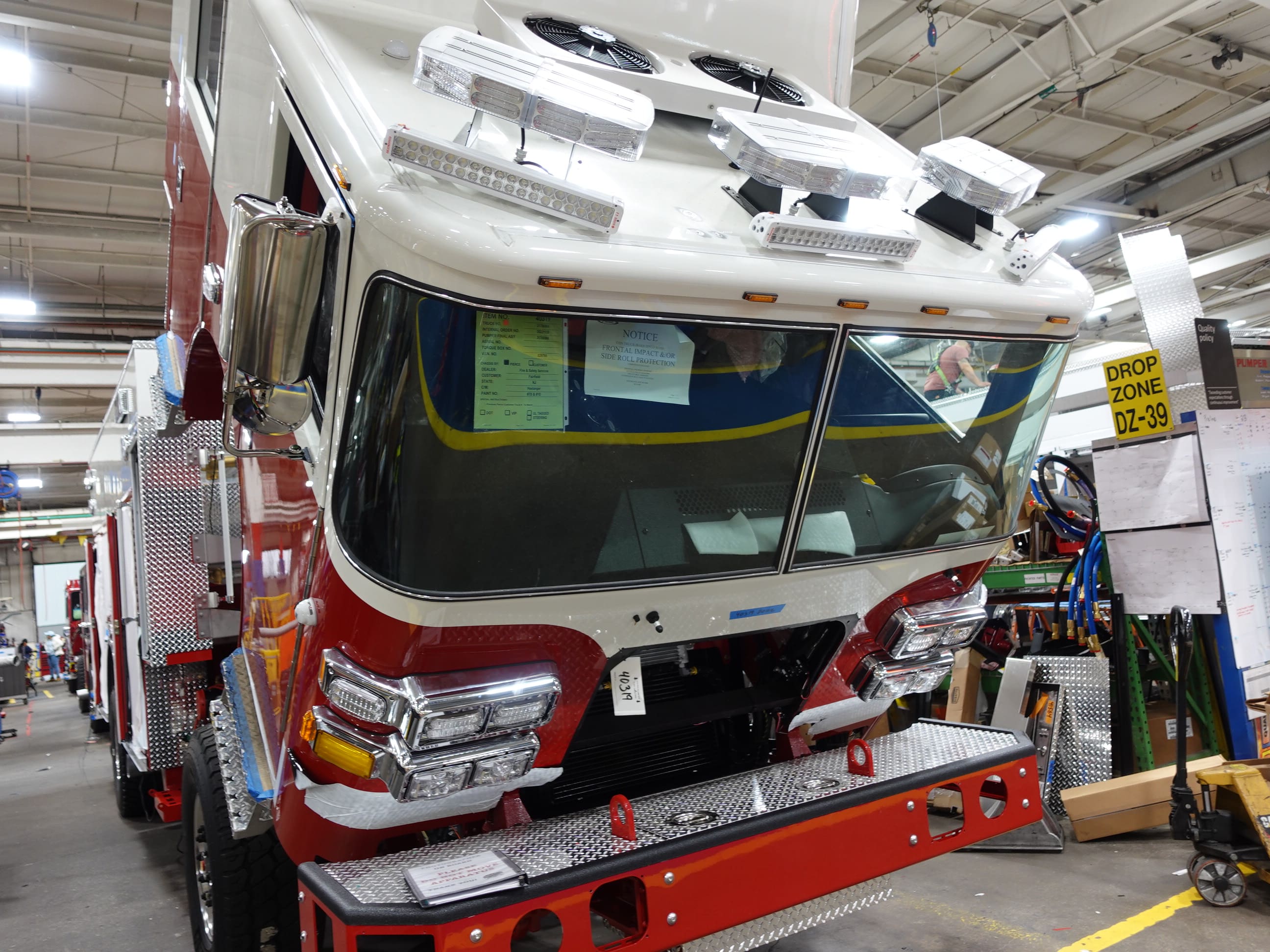

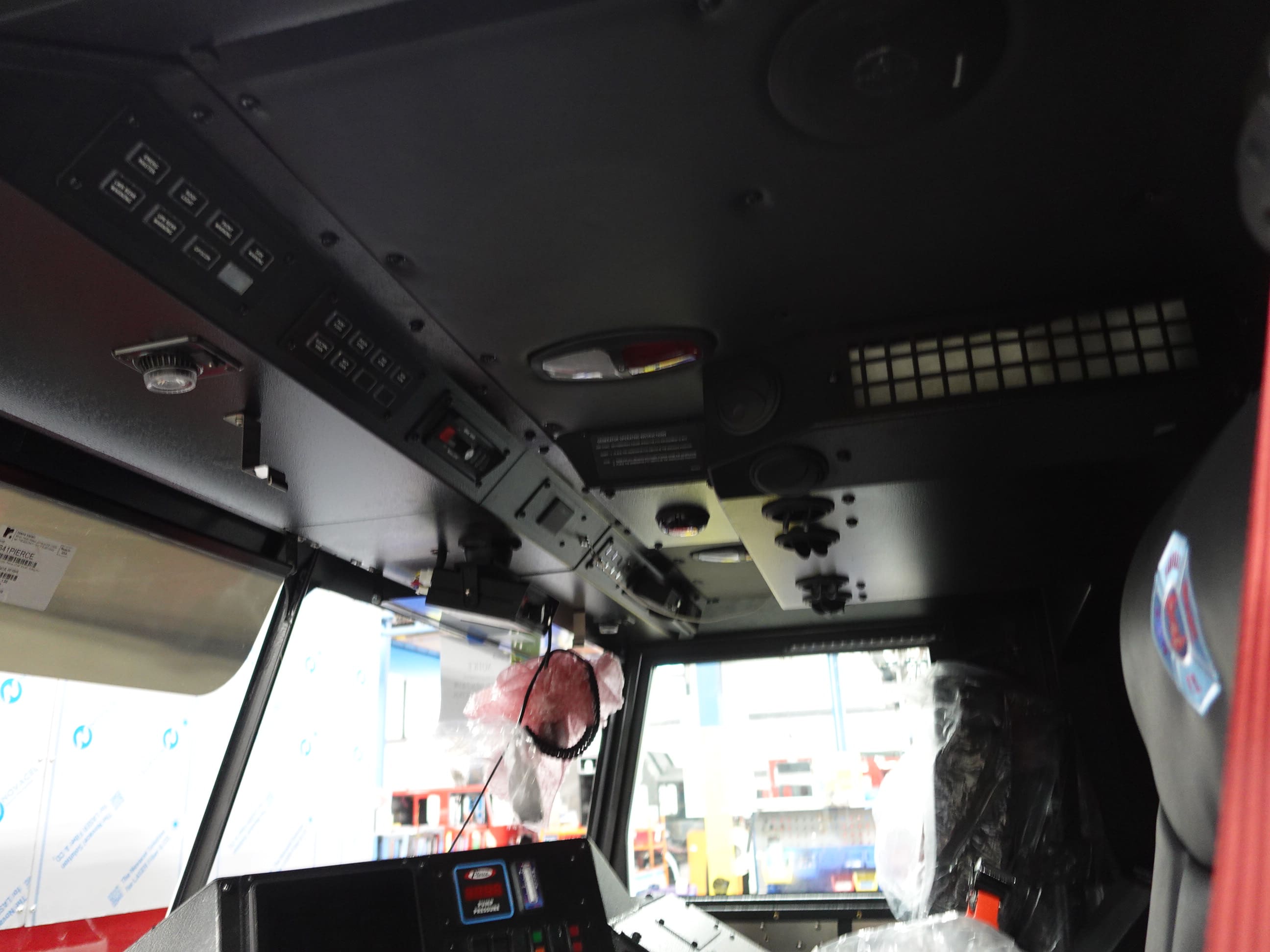

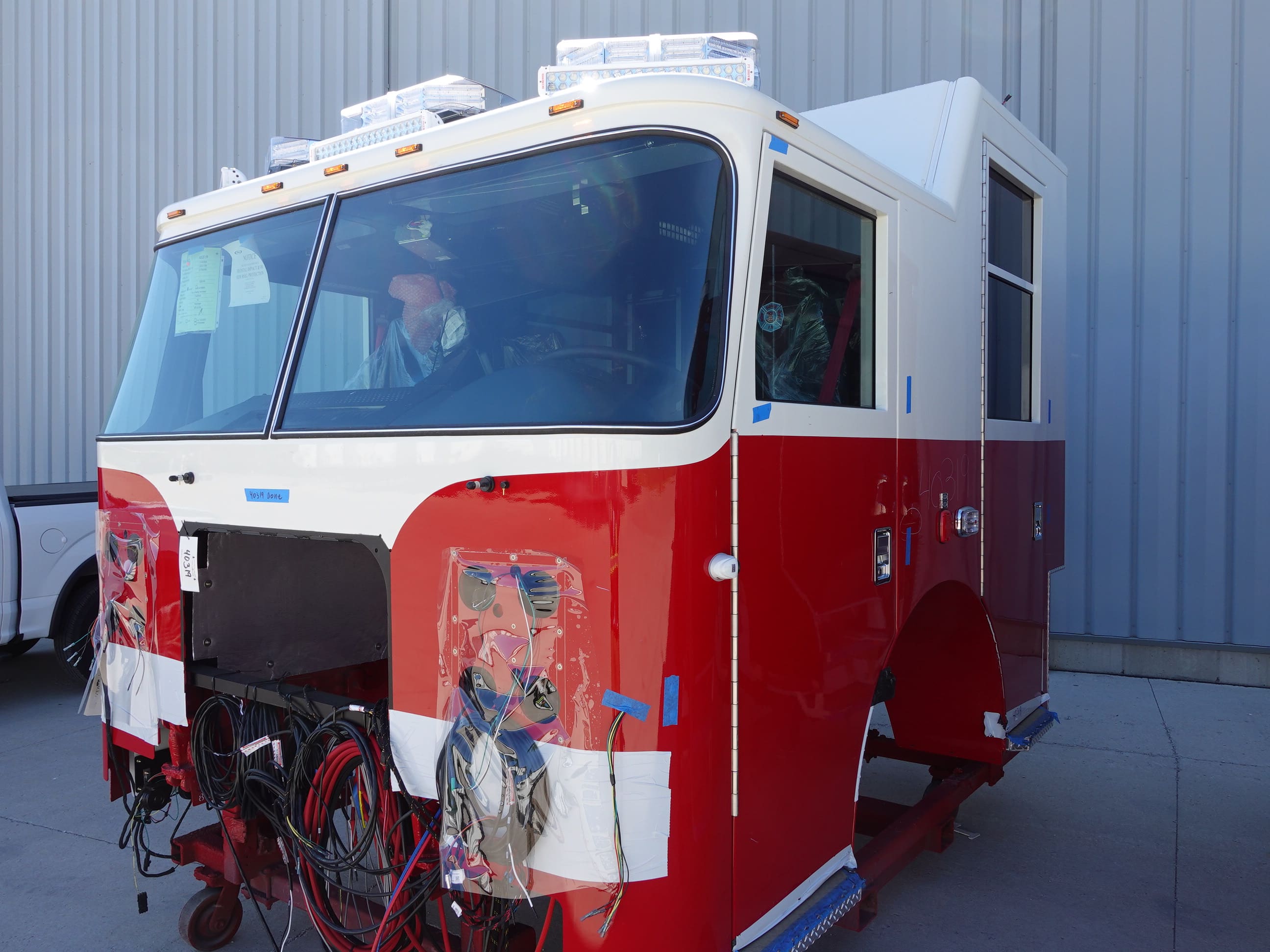

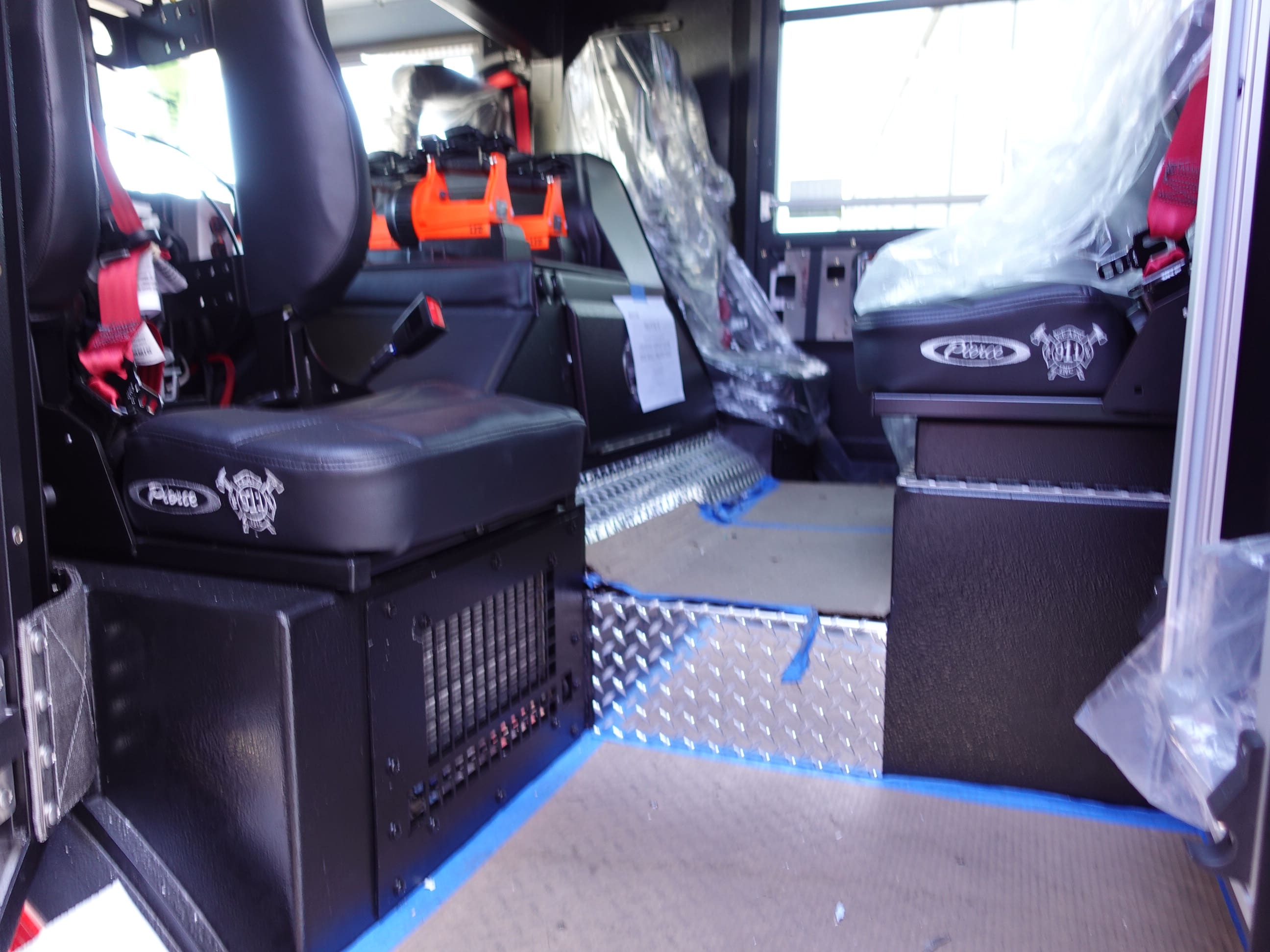

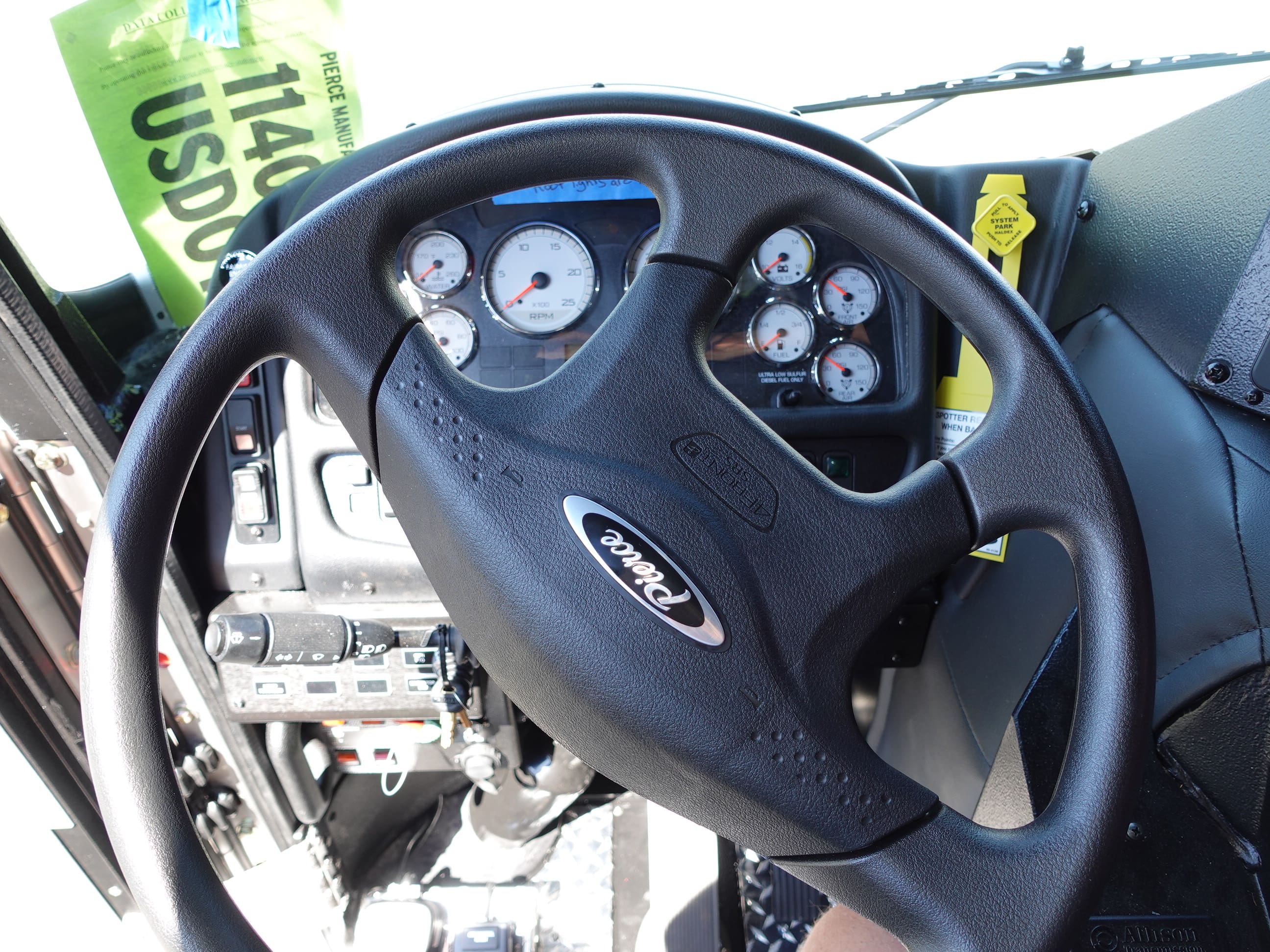

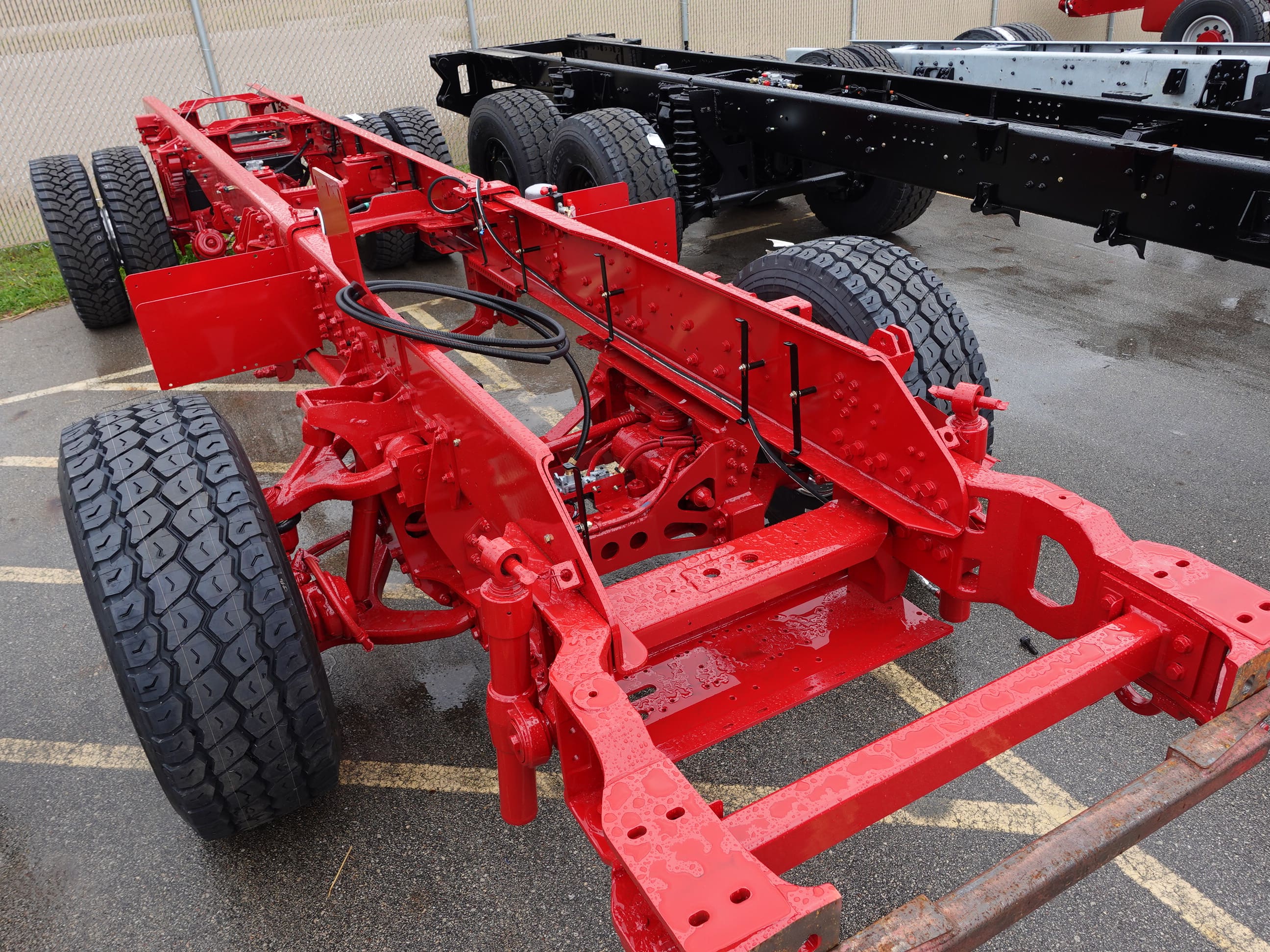

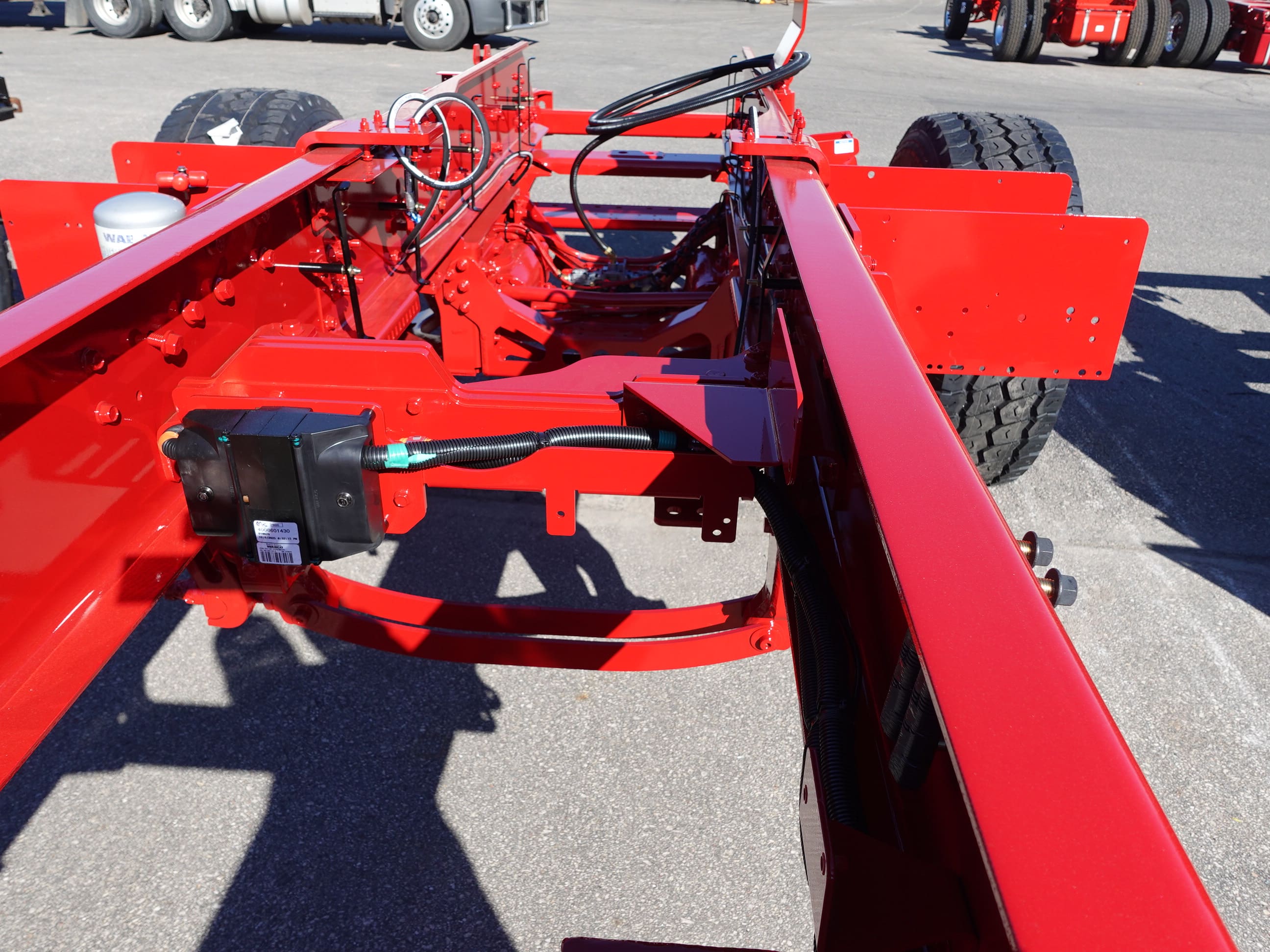

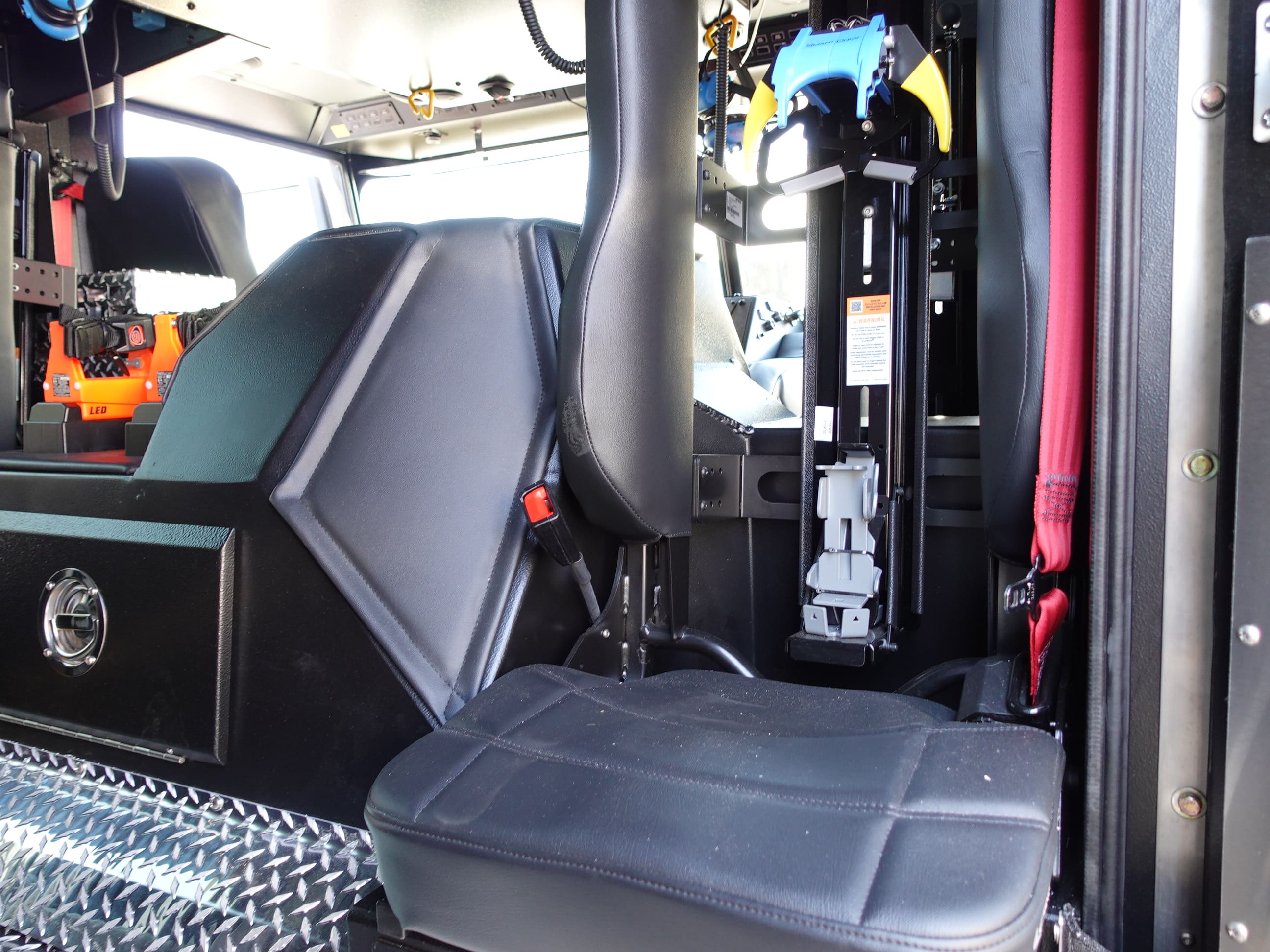

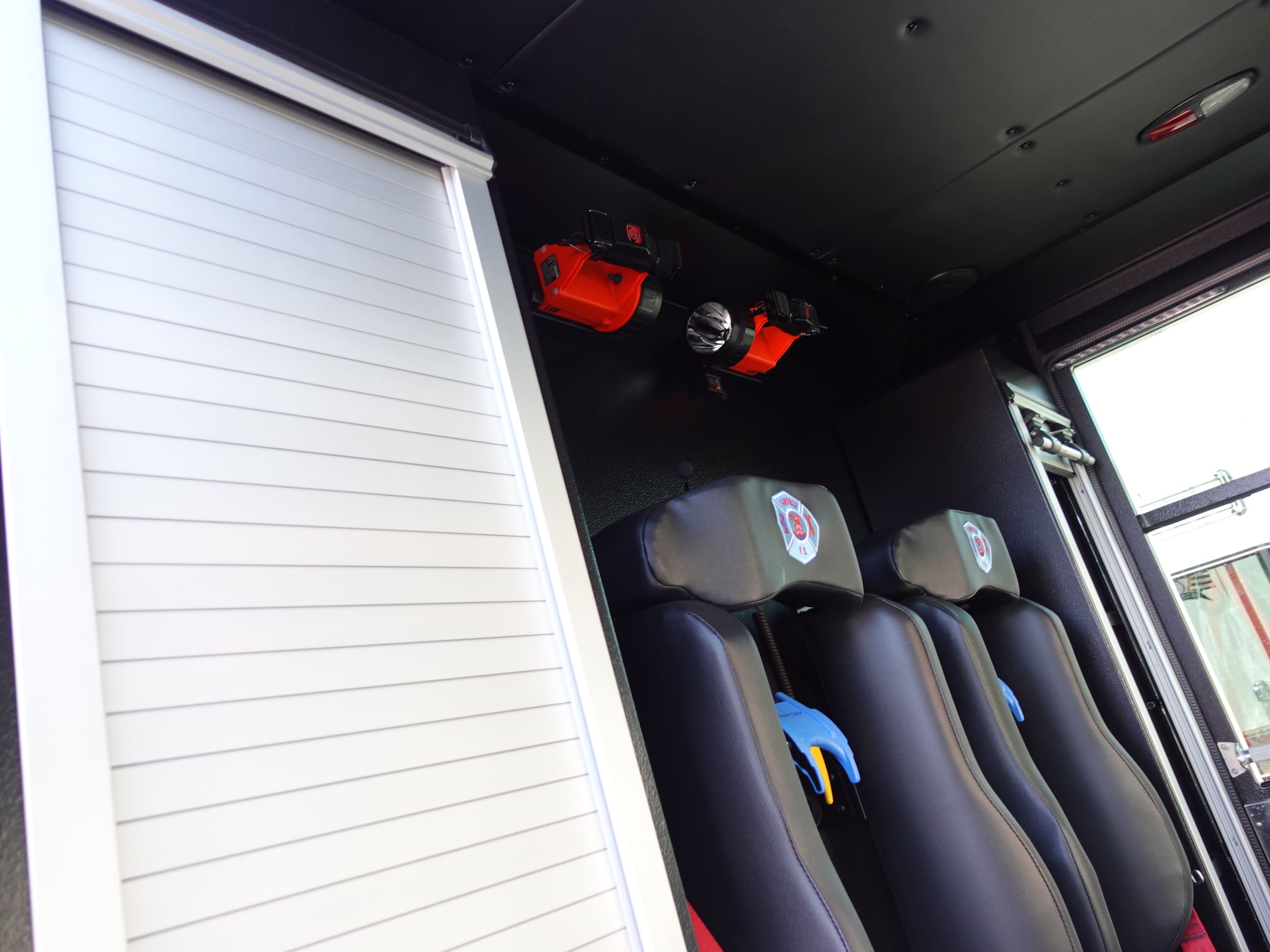

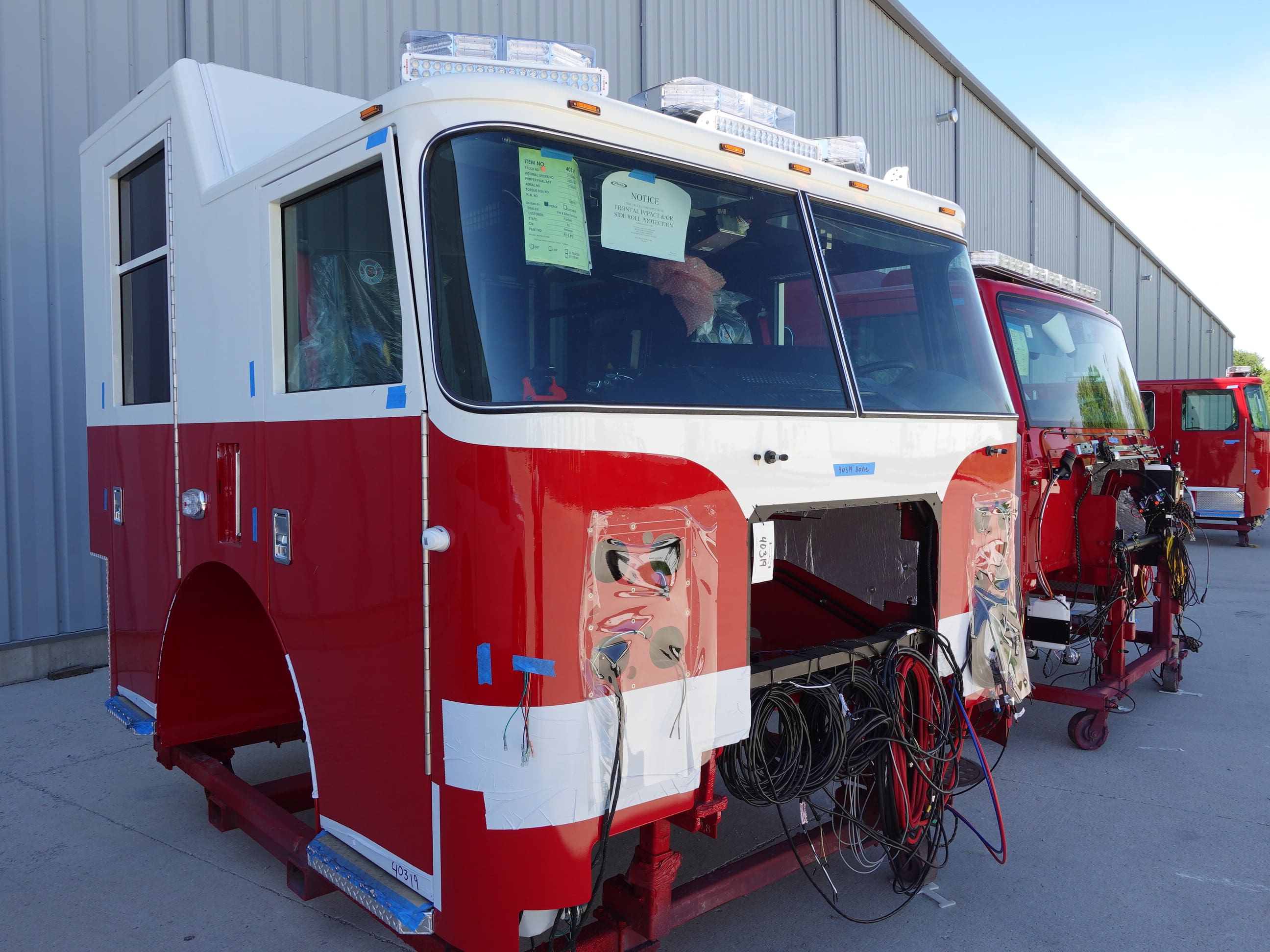

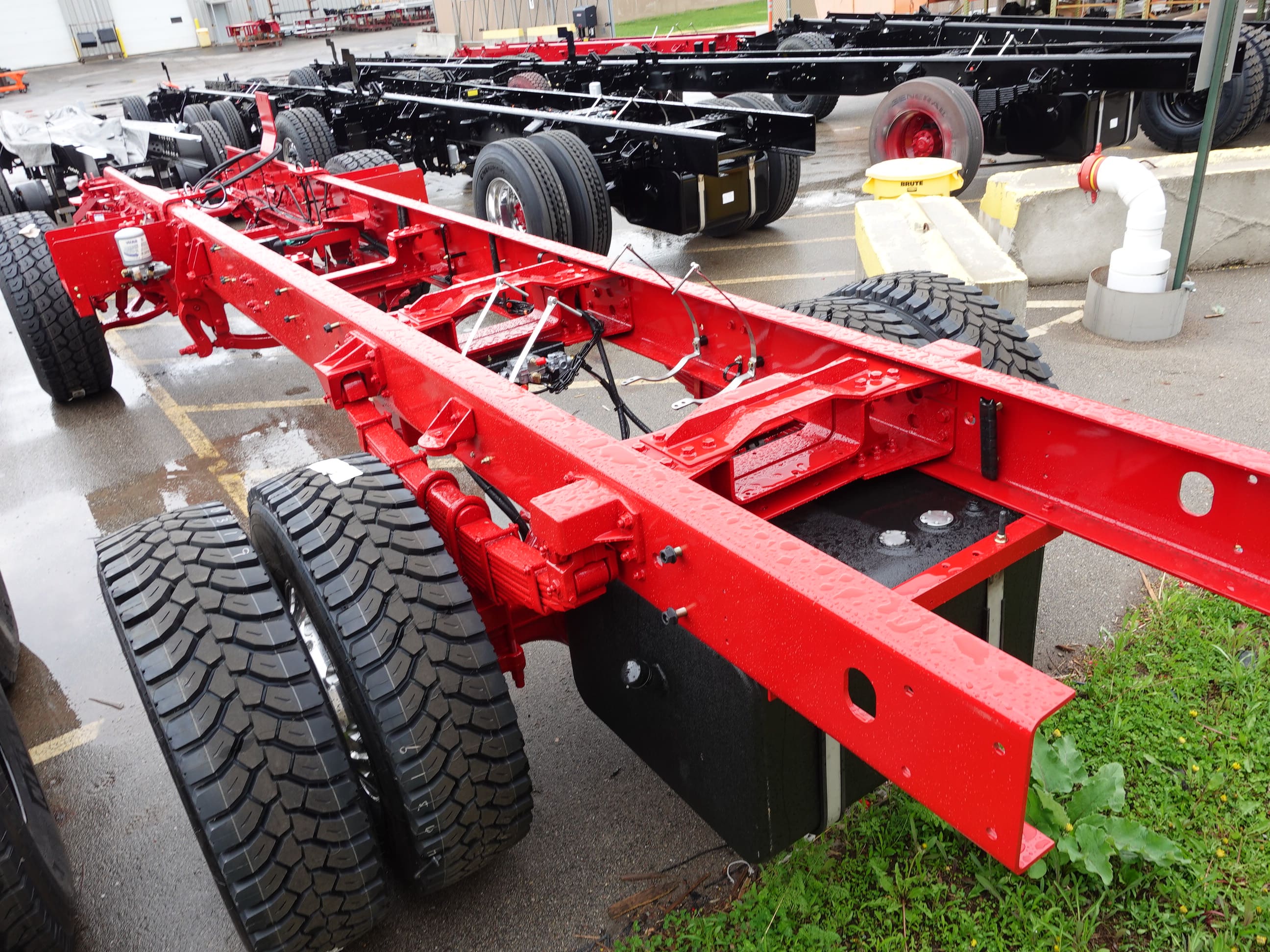

In this report, the cab completed initial assembly, the frame build continued, and the body began

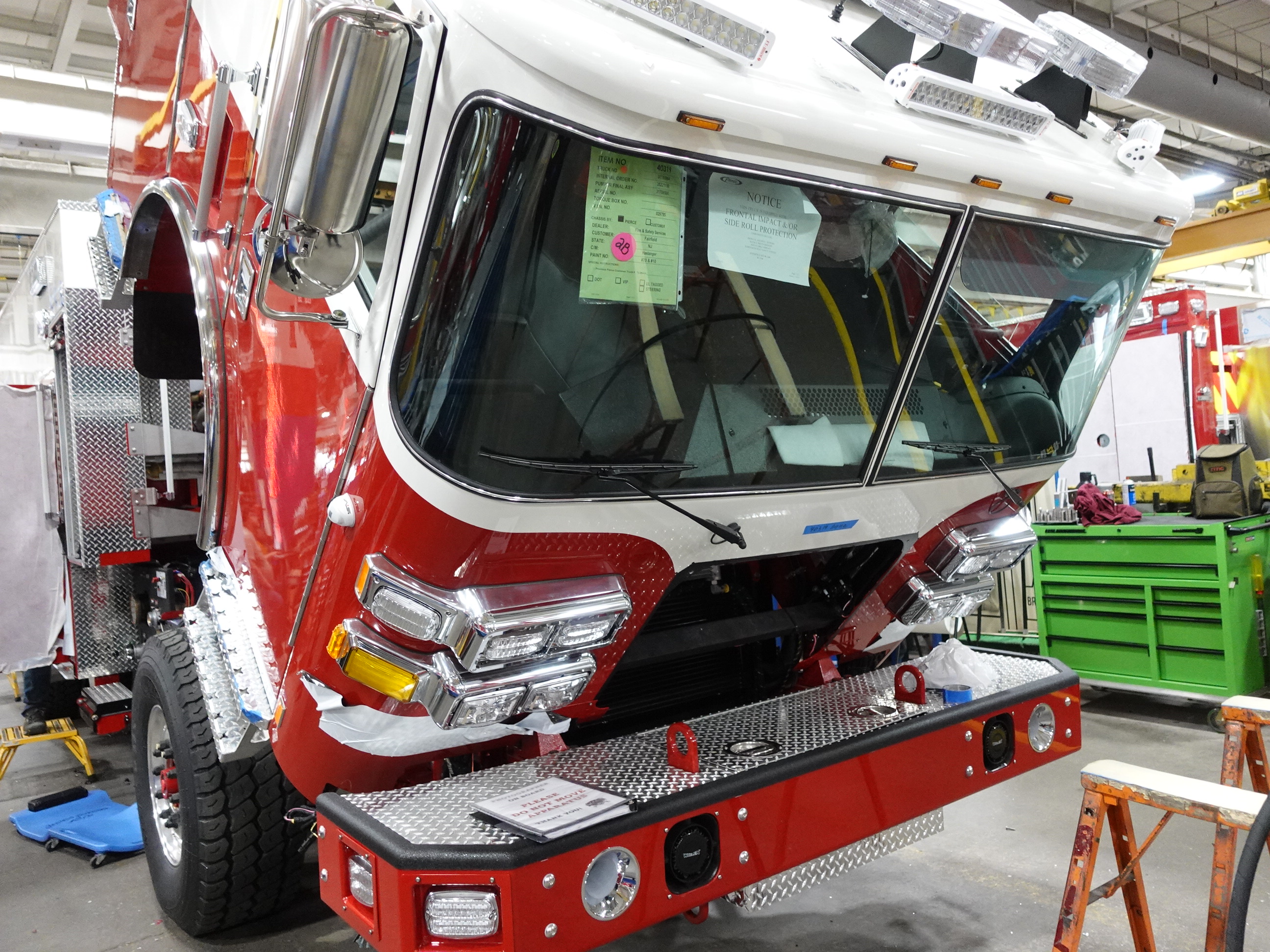

initial assembly.

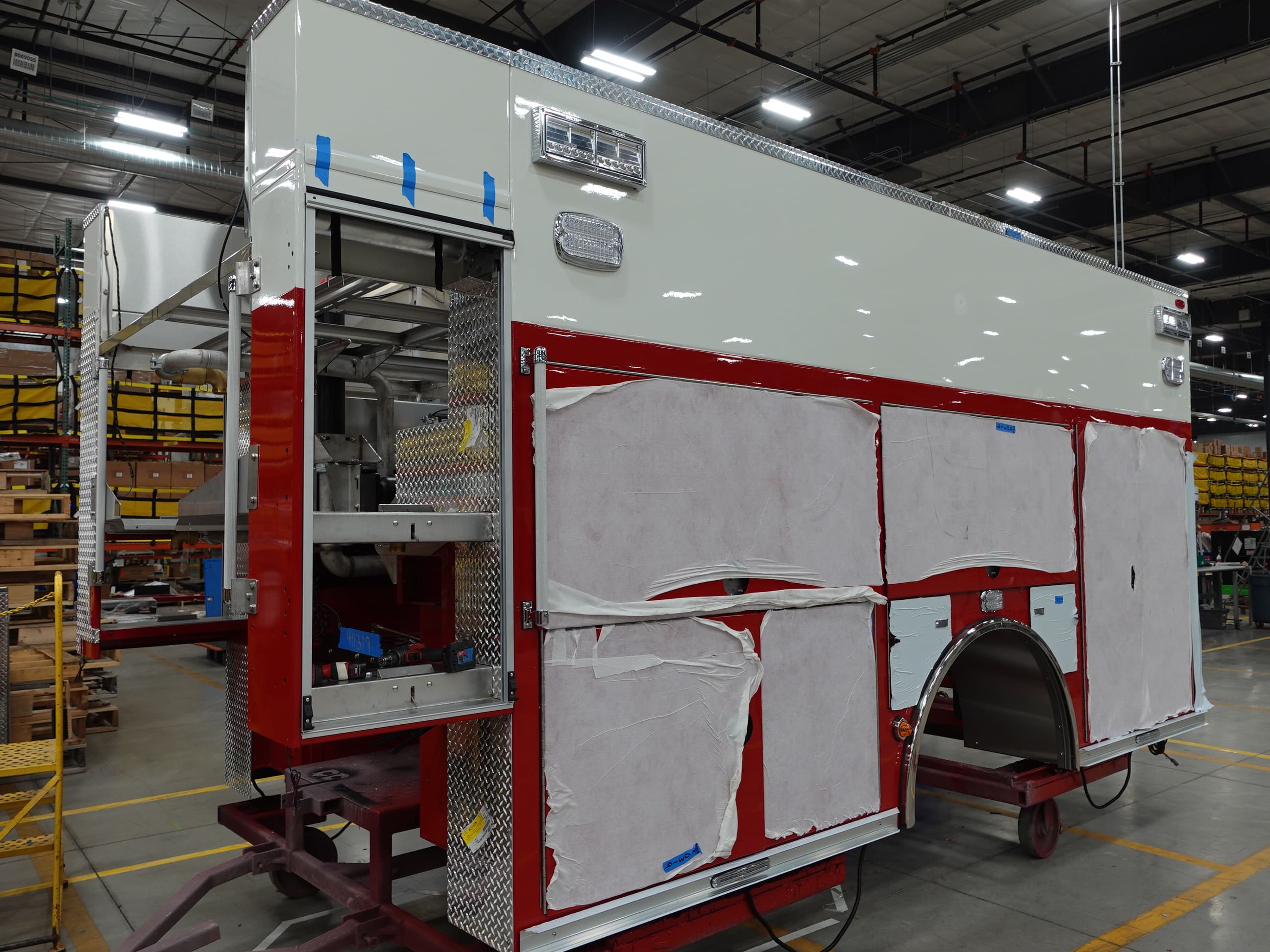

05-22-26

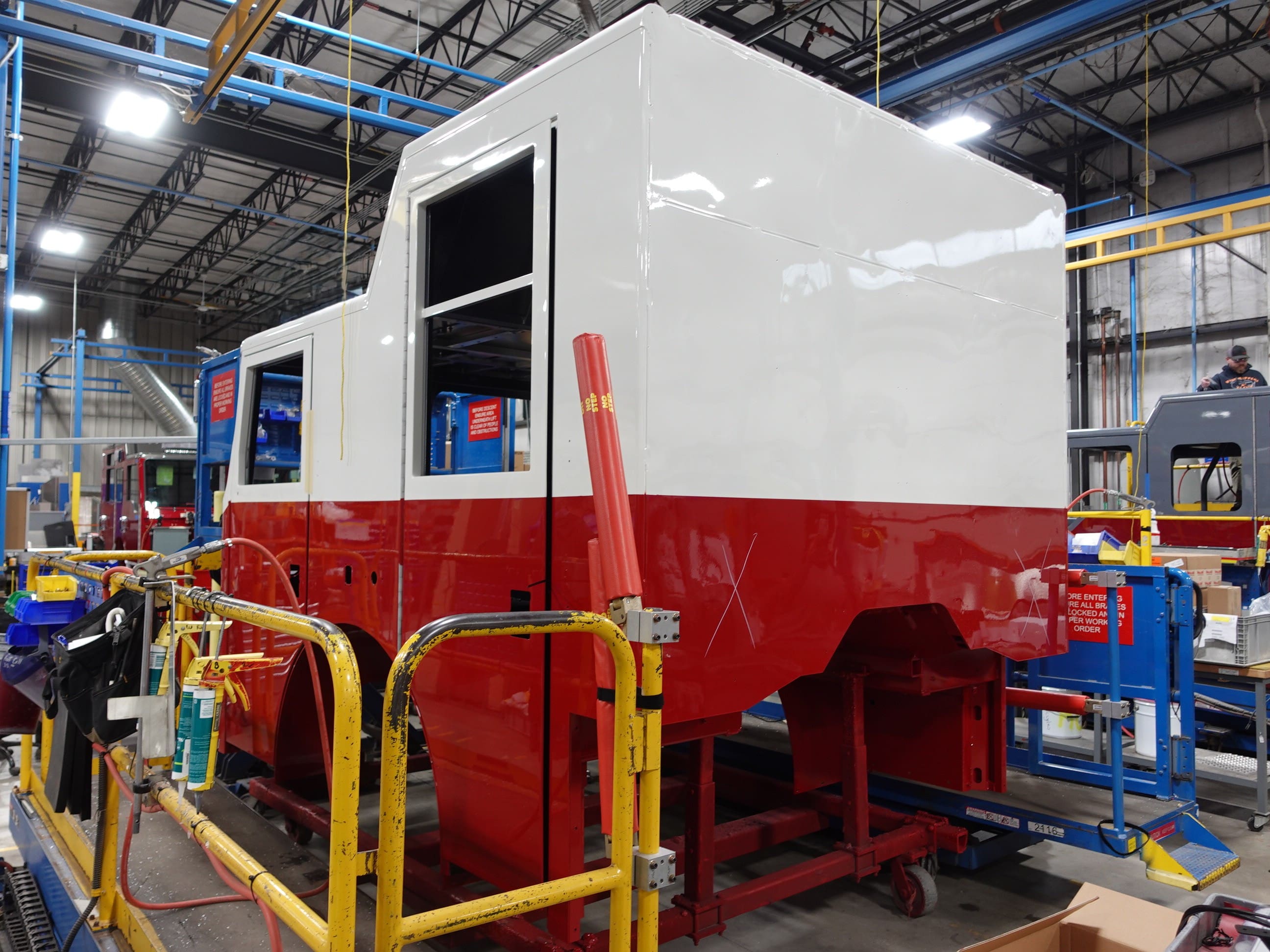

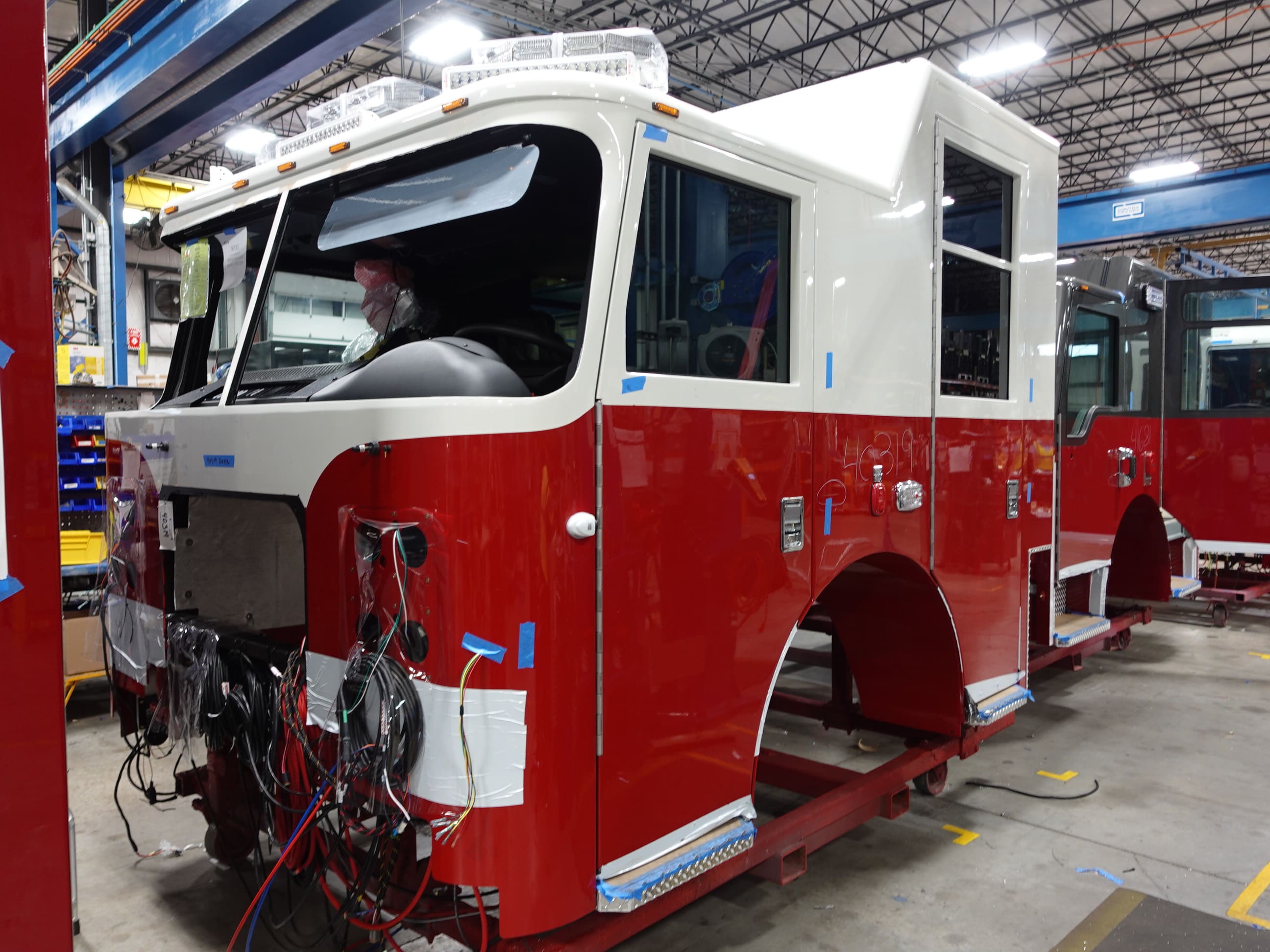

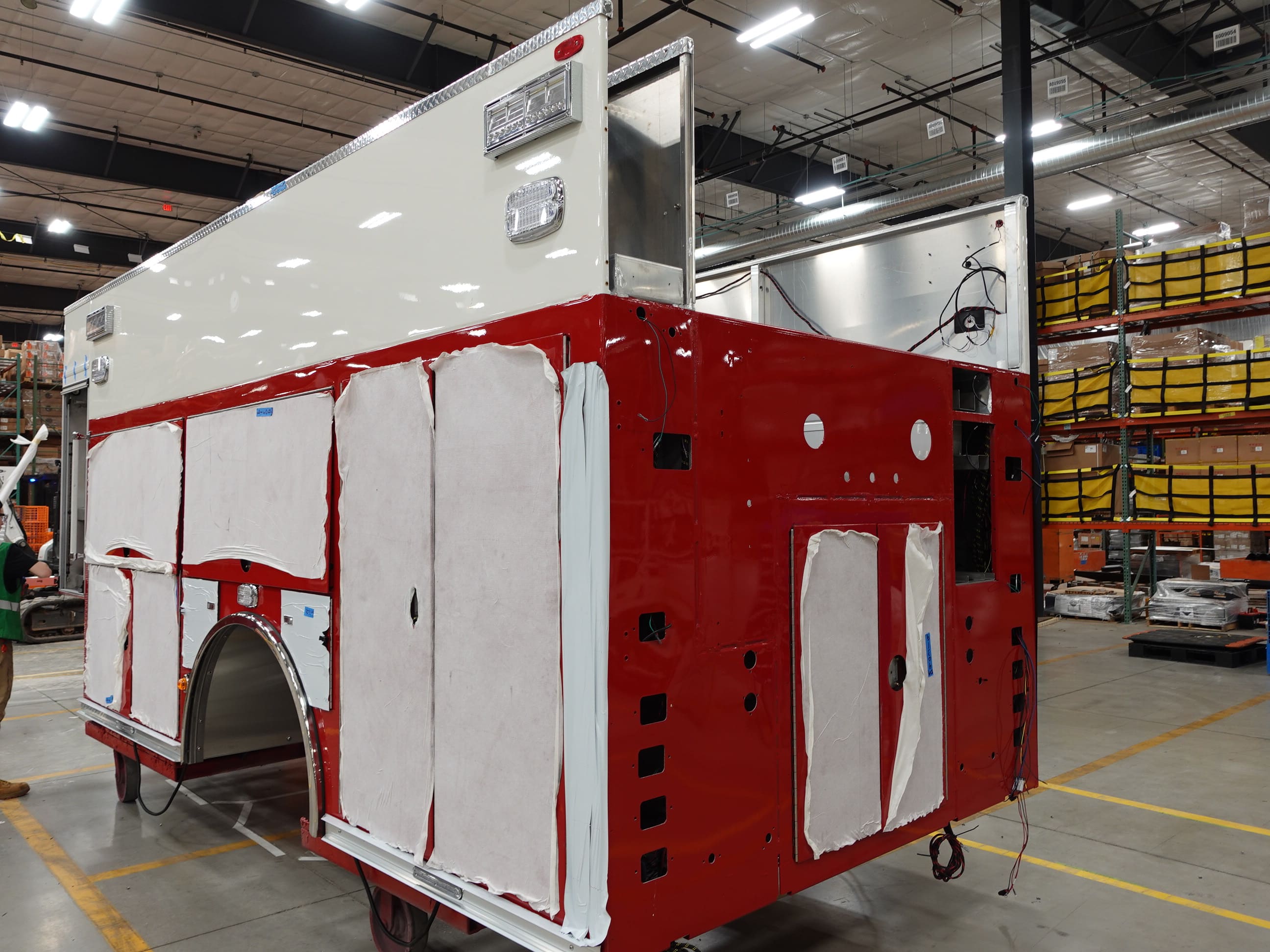

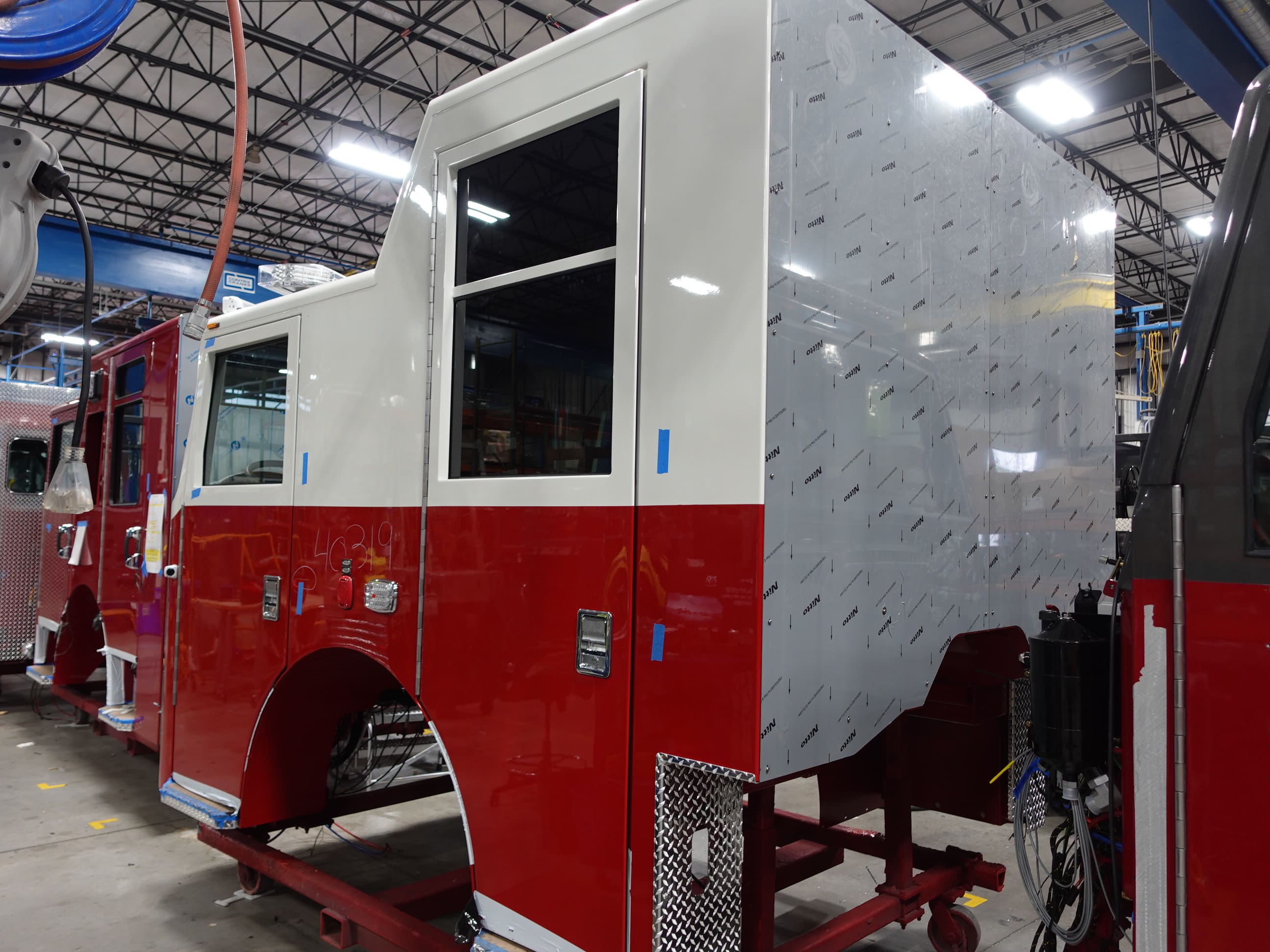

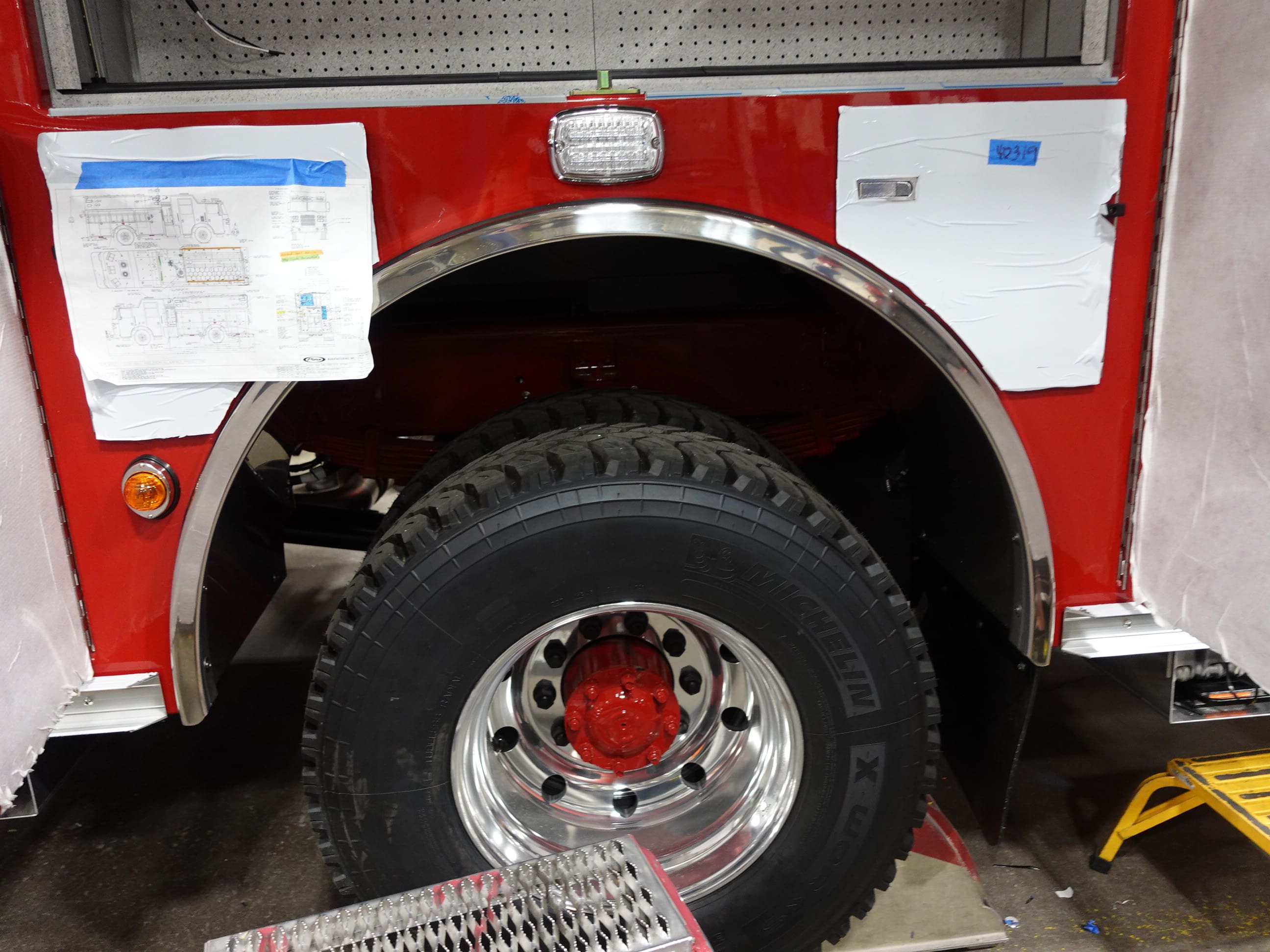

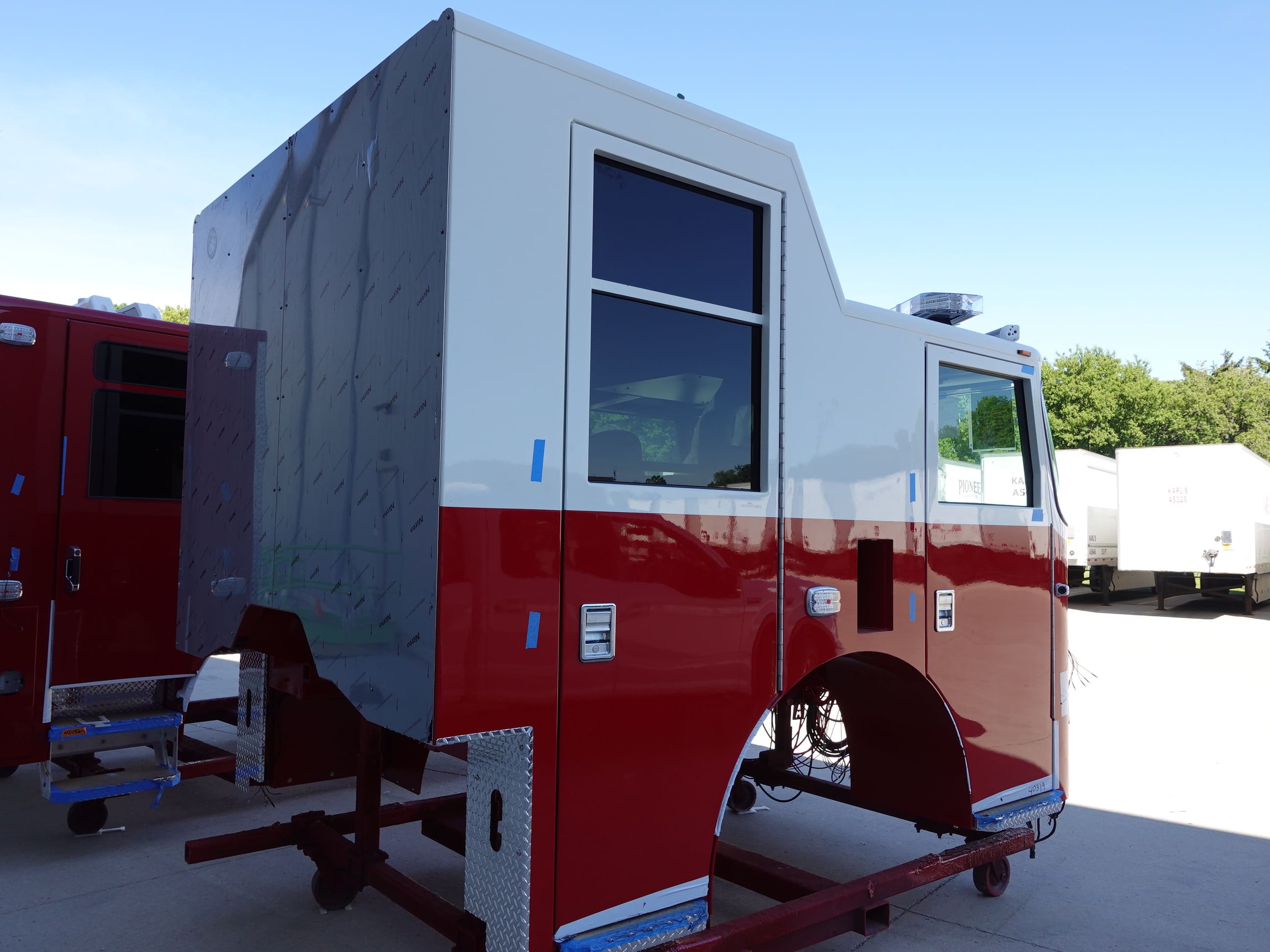

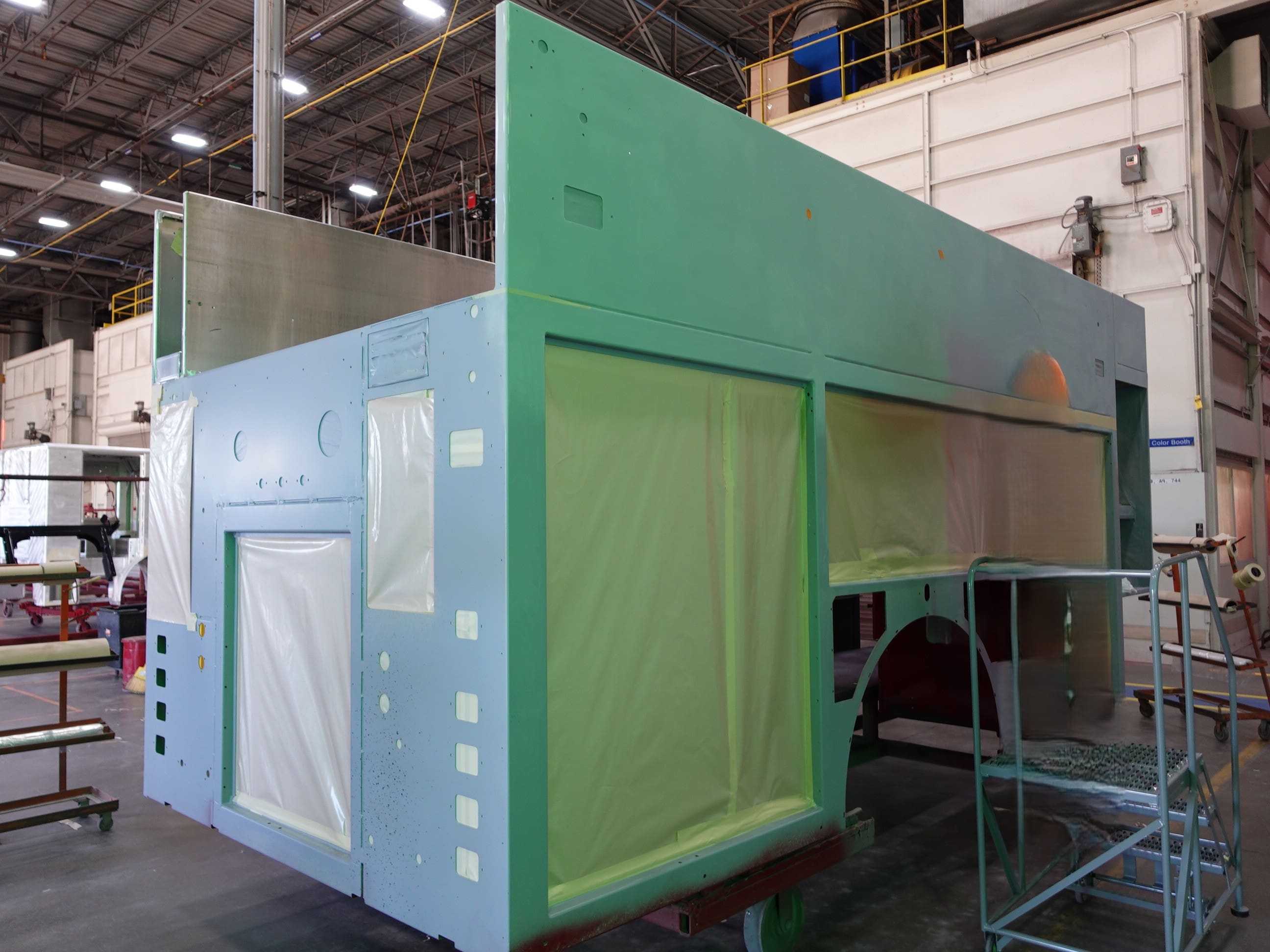

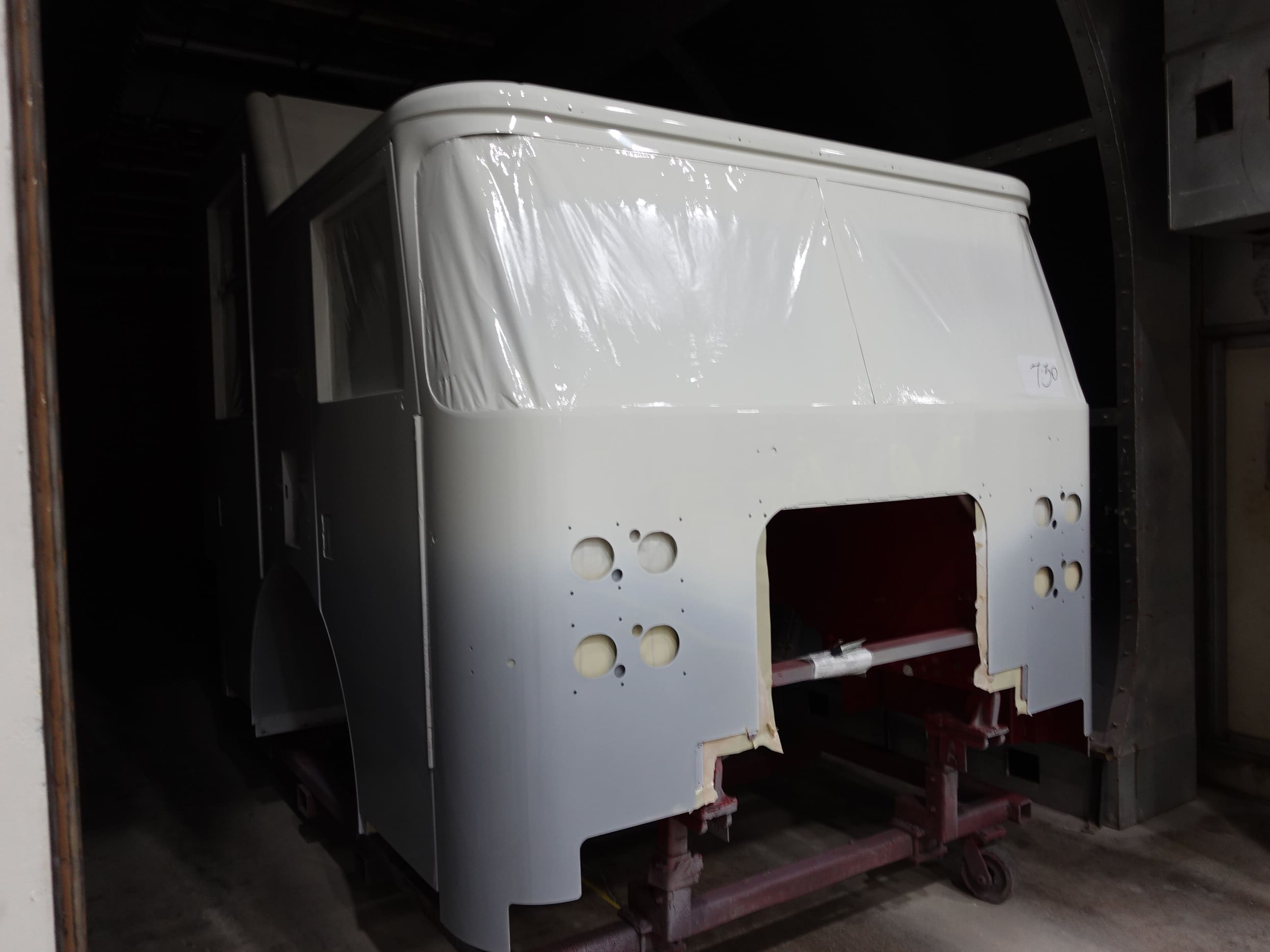

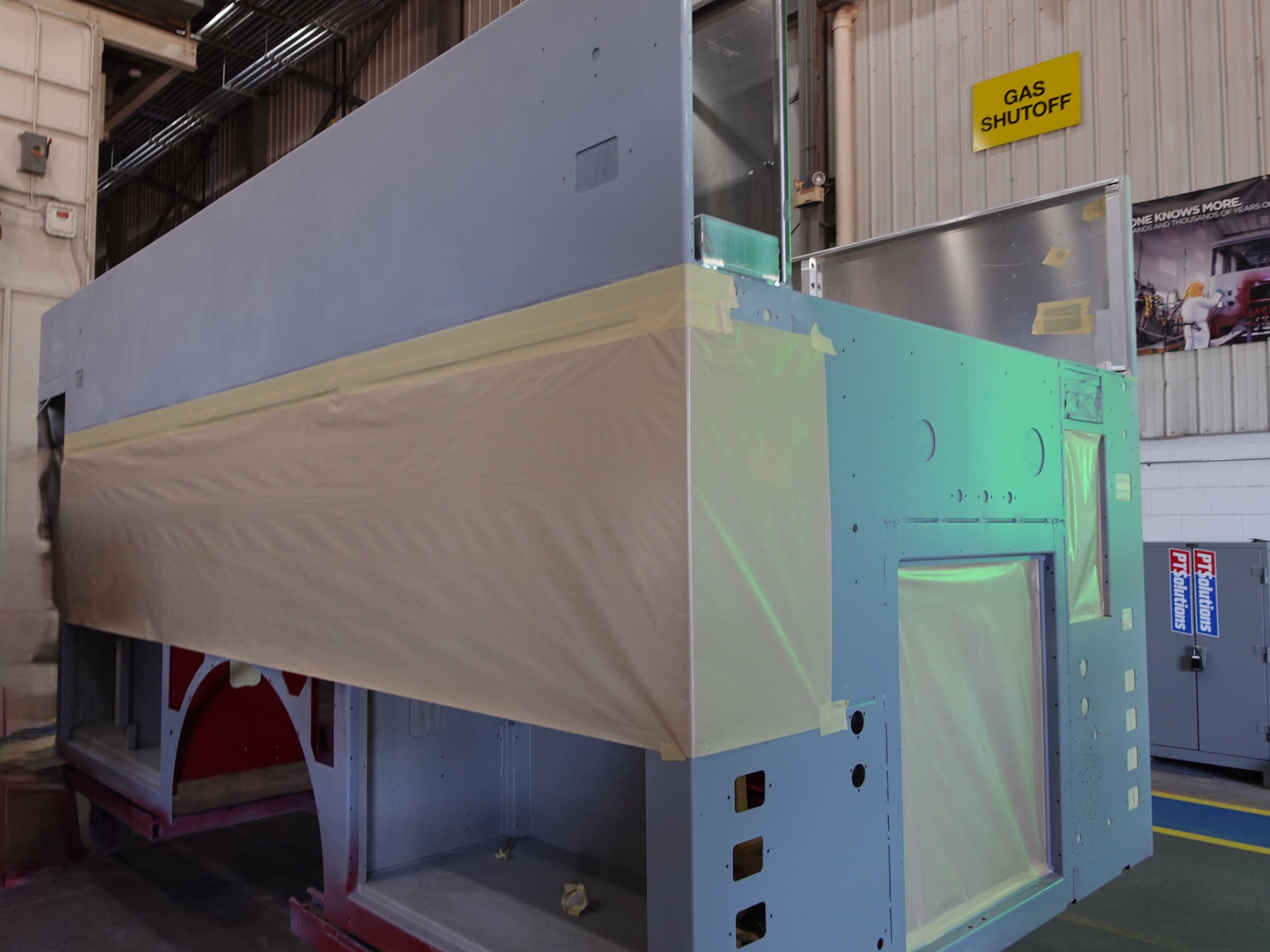

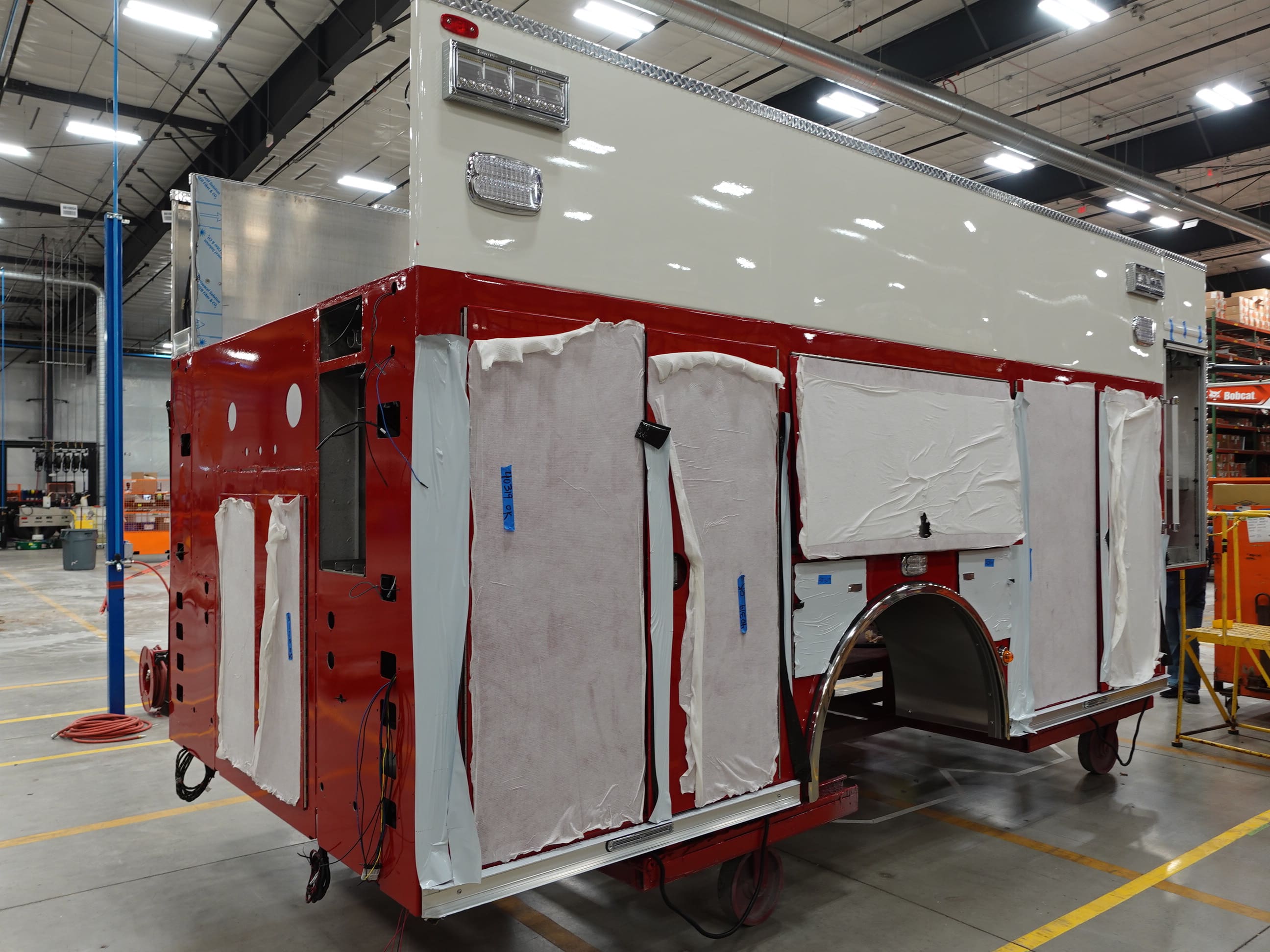

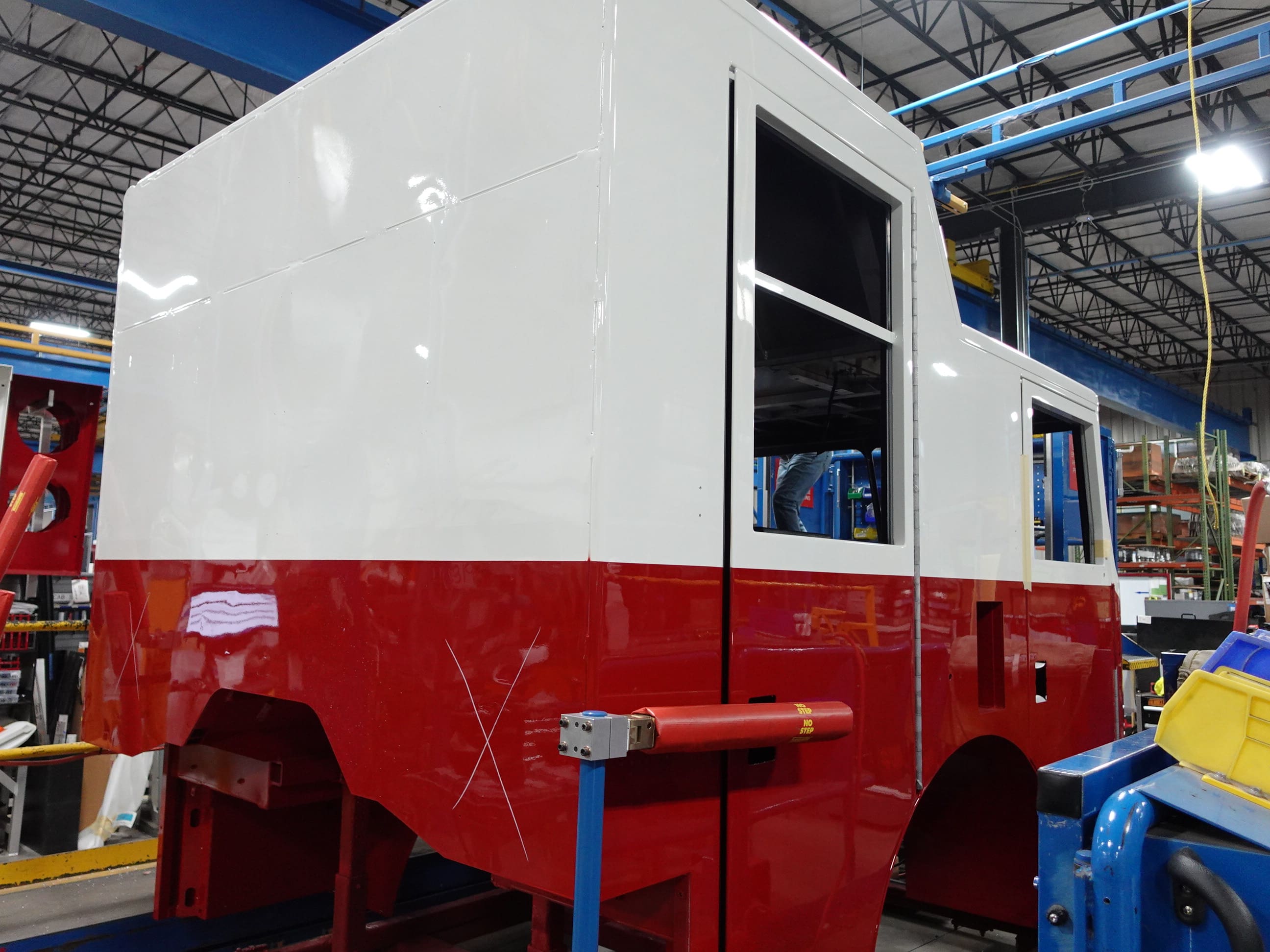

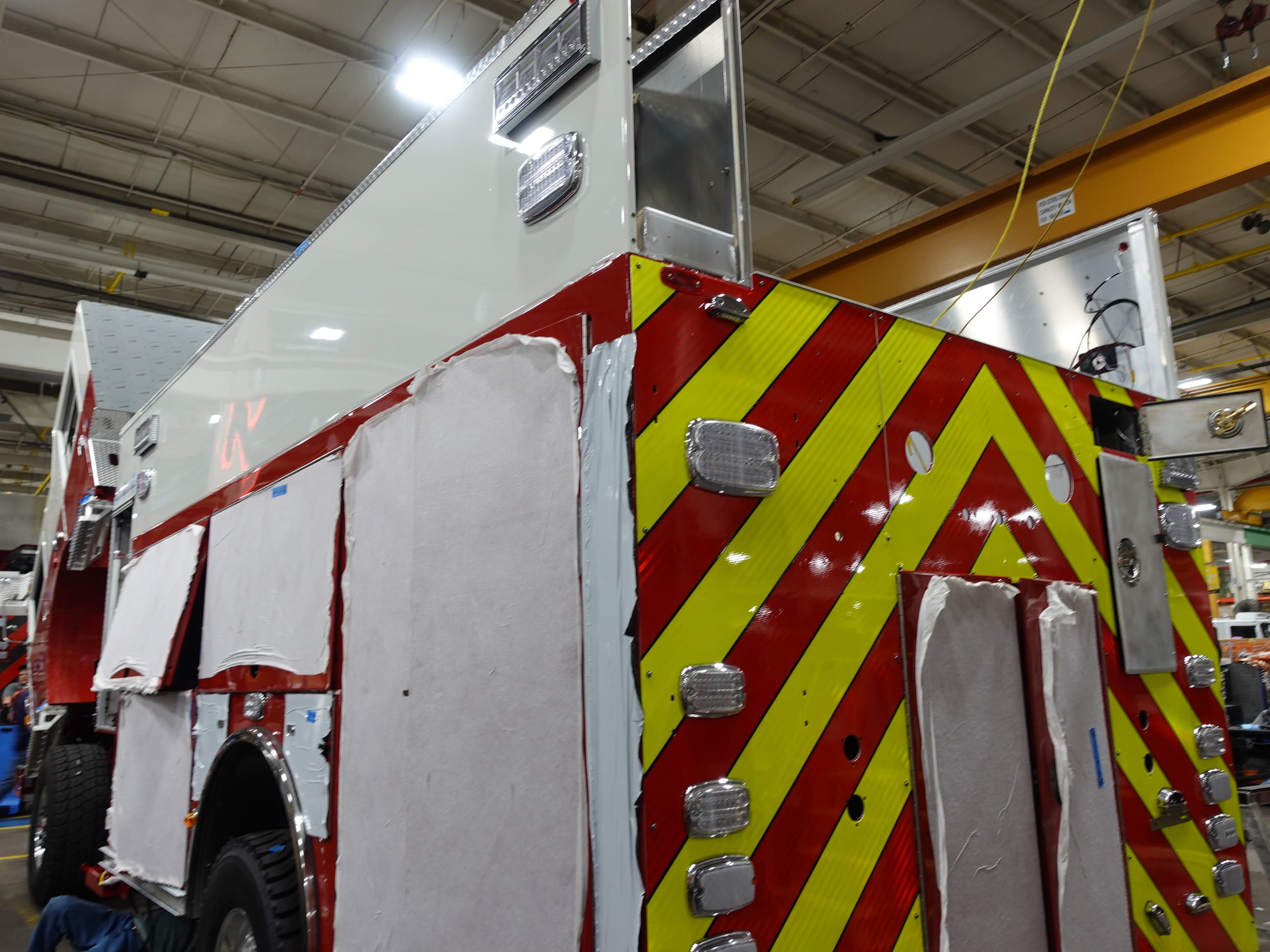

In this report, the cab continued initial assembly, the frame build continued, and the body completed fabrication and completed the paint process.

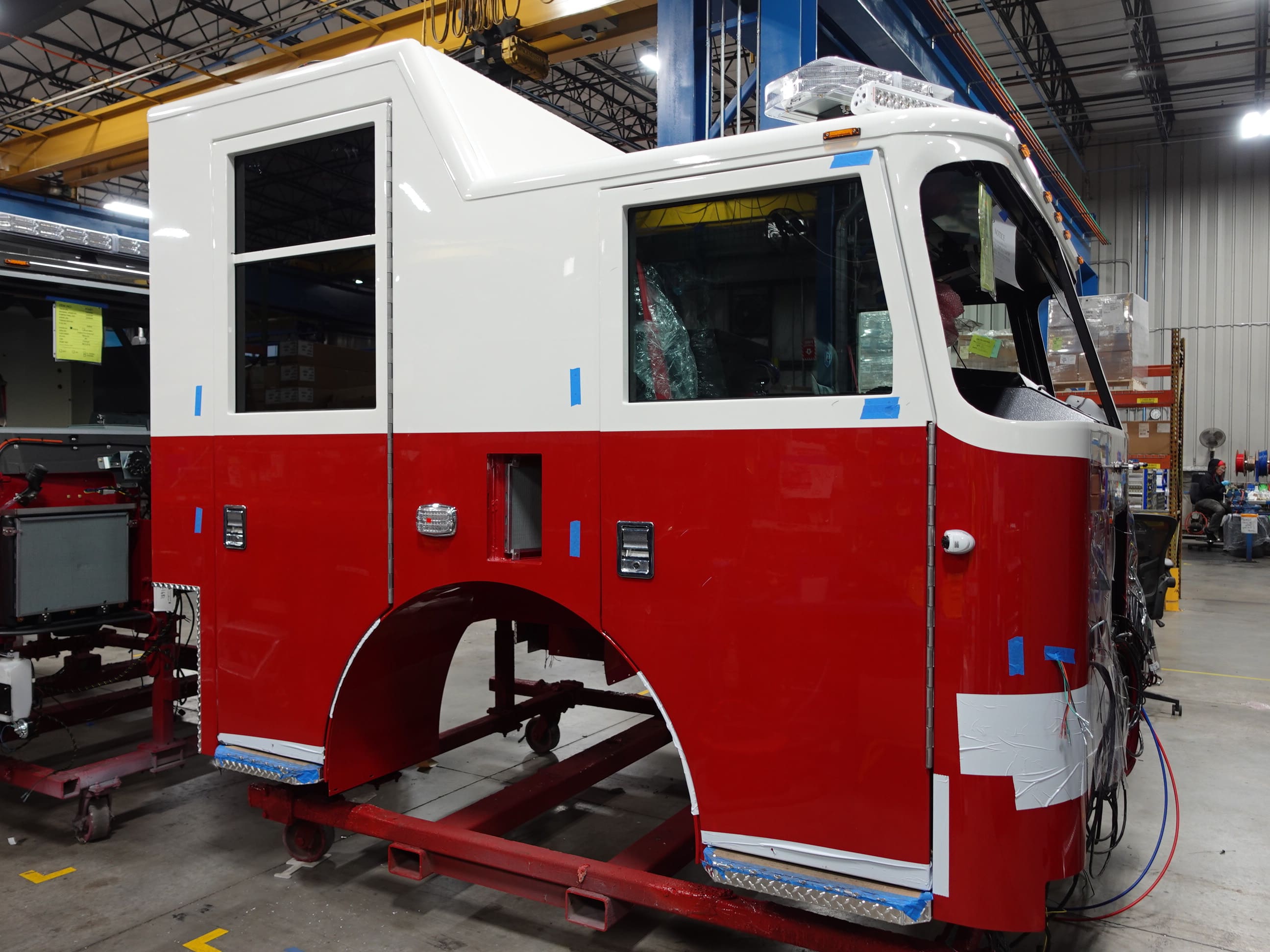

05-15-26

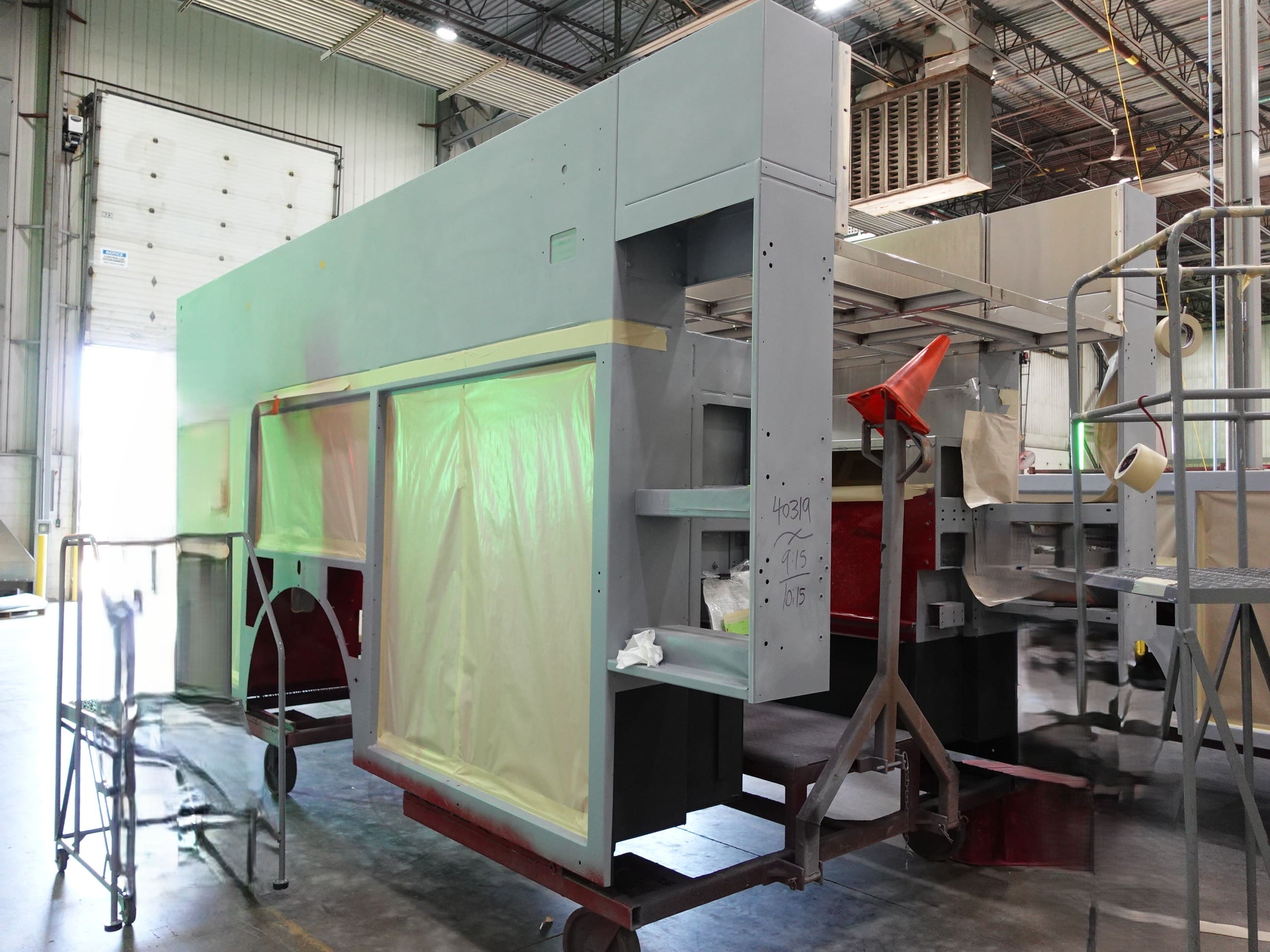

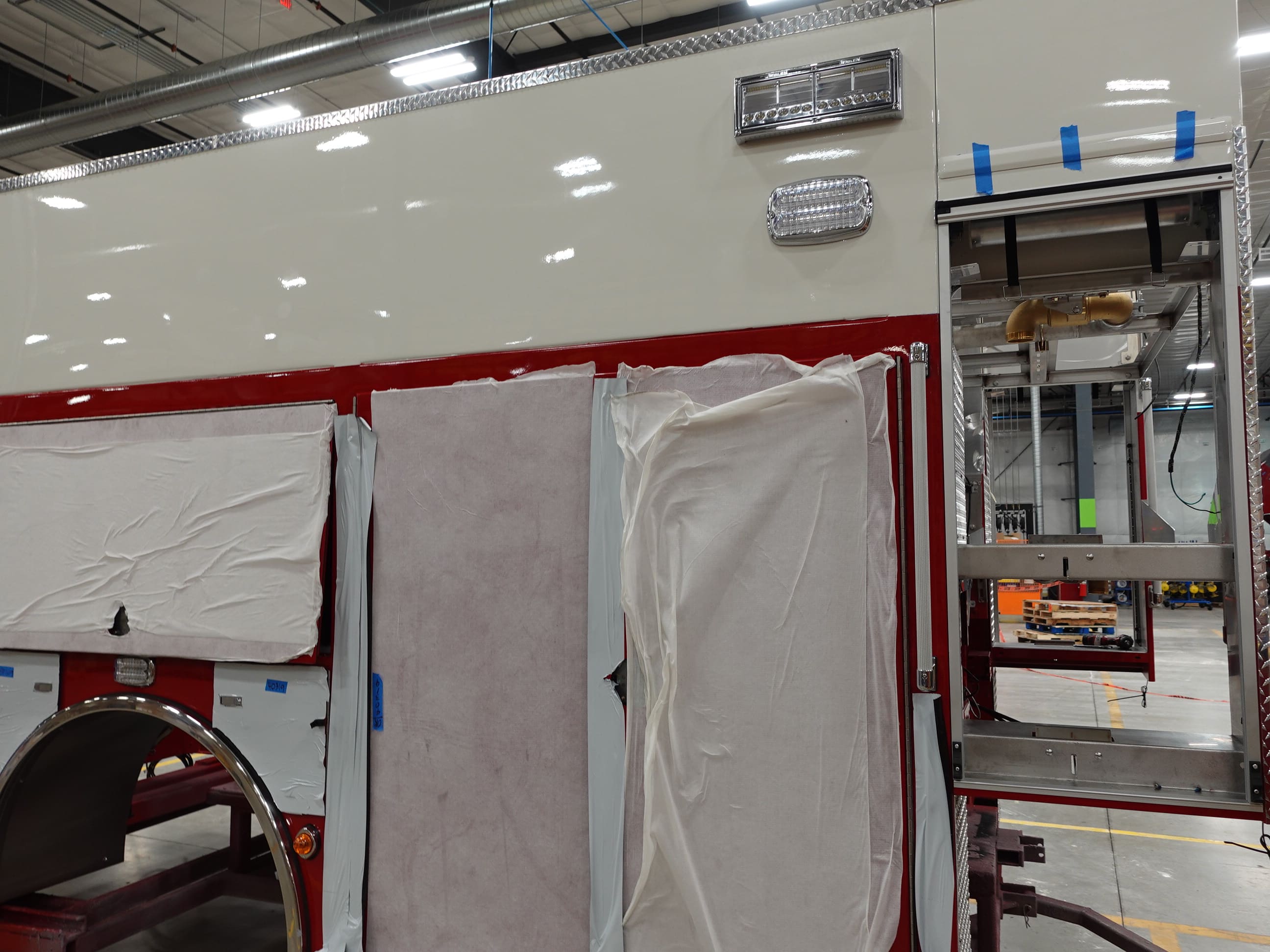

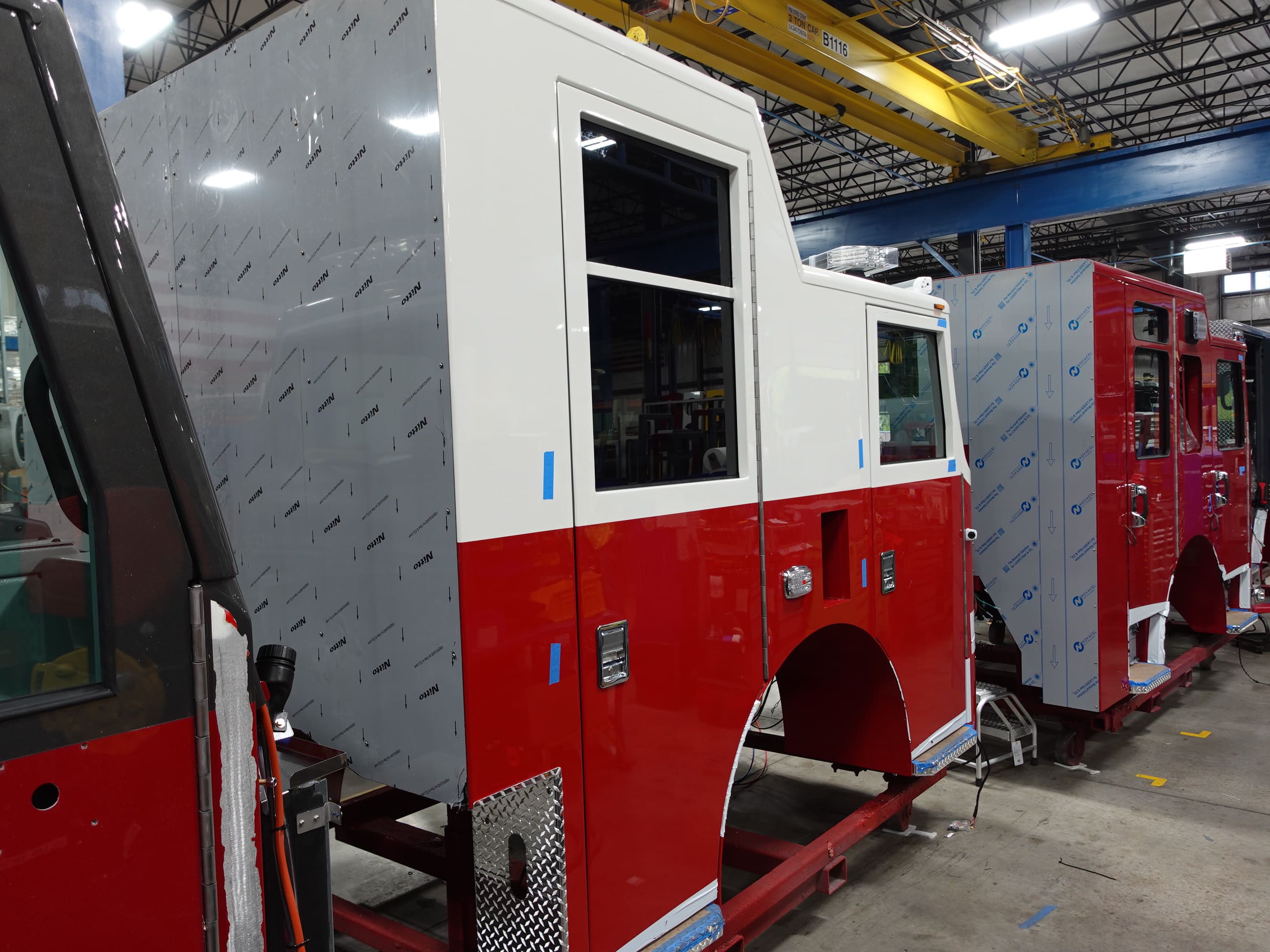

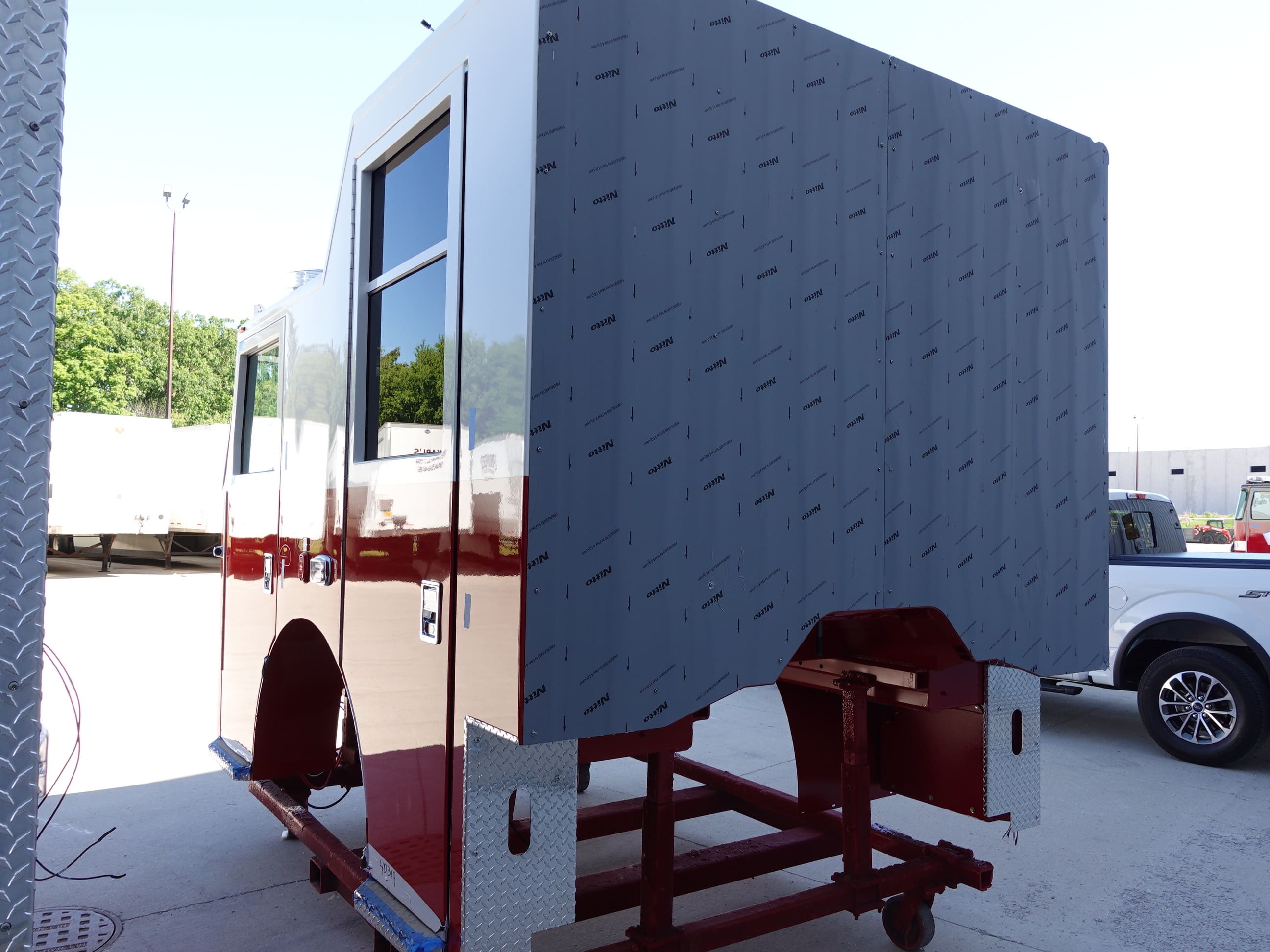

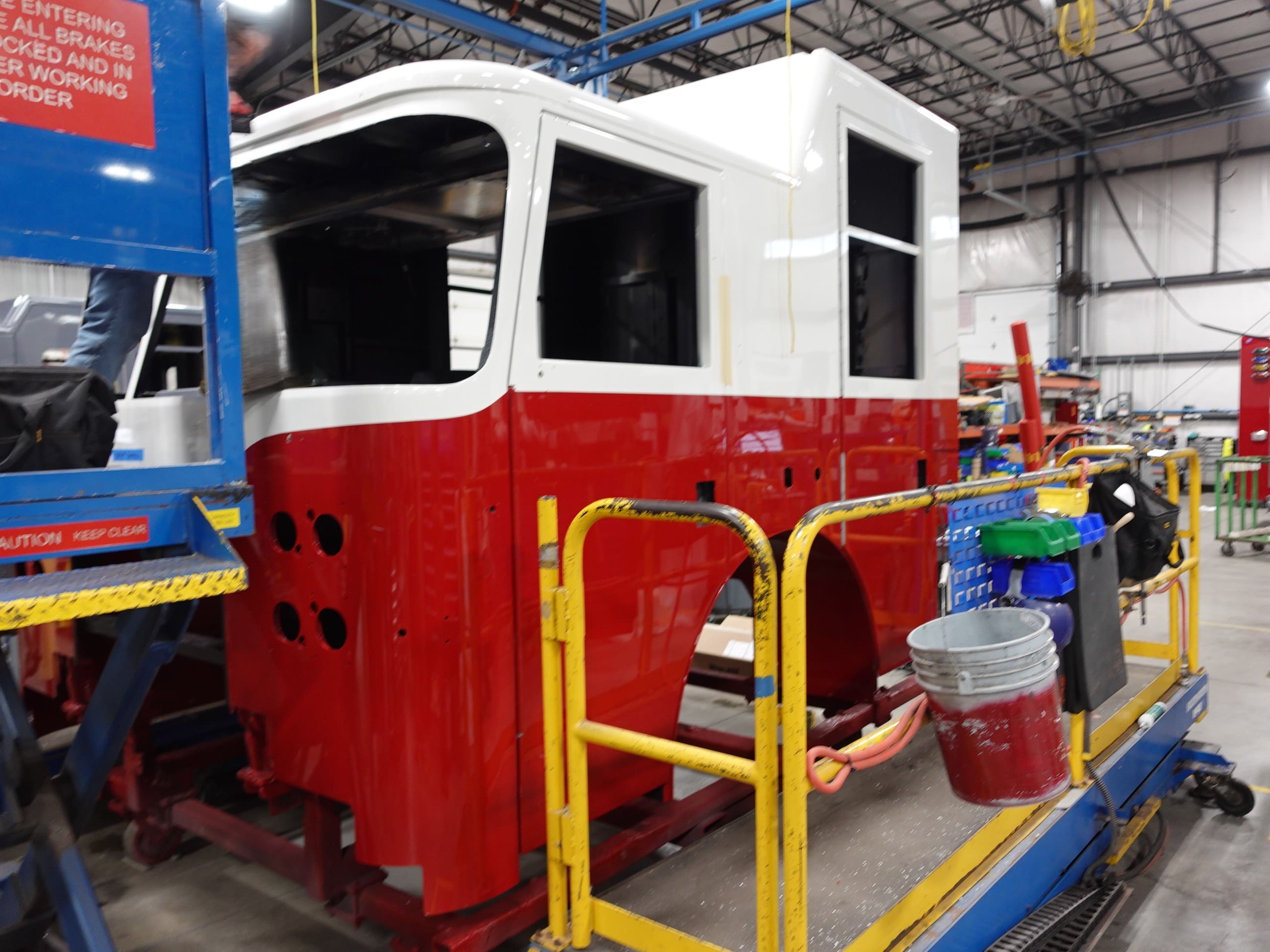

In this report, the cab completed paint and began initial assembly, the frame build continued, and the body completed fabrication and began the paint process.

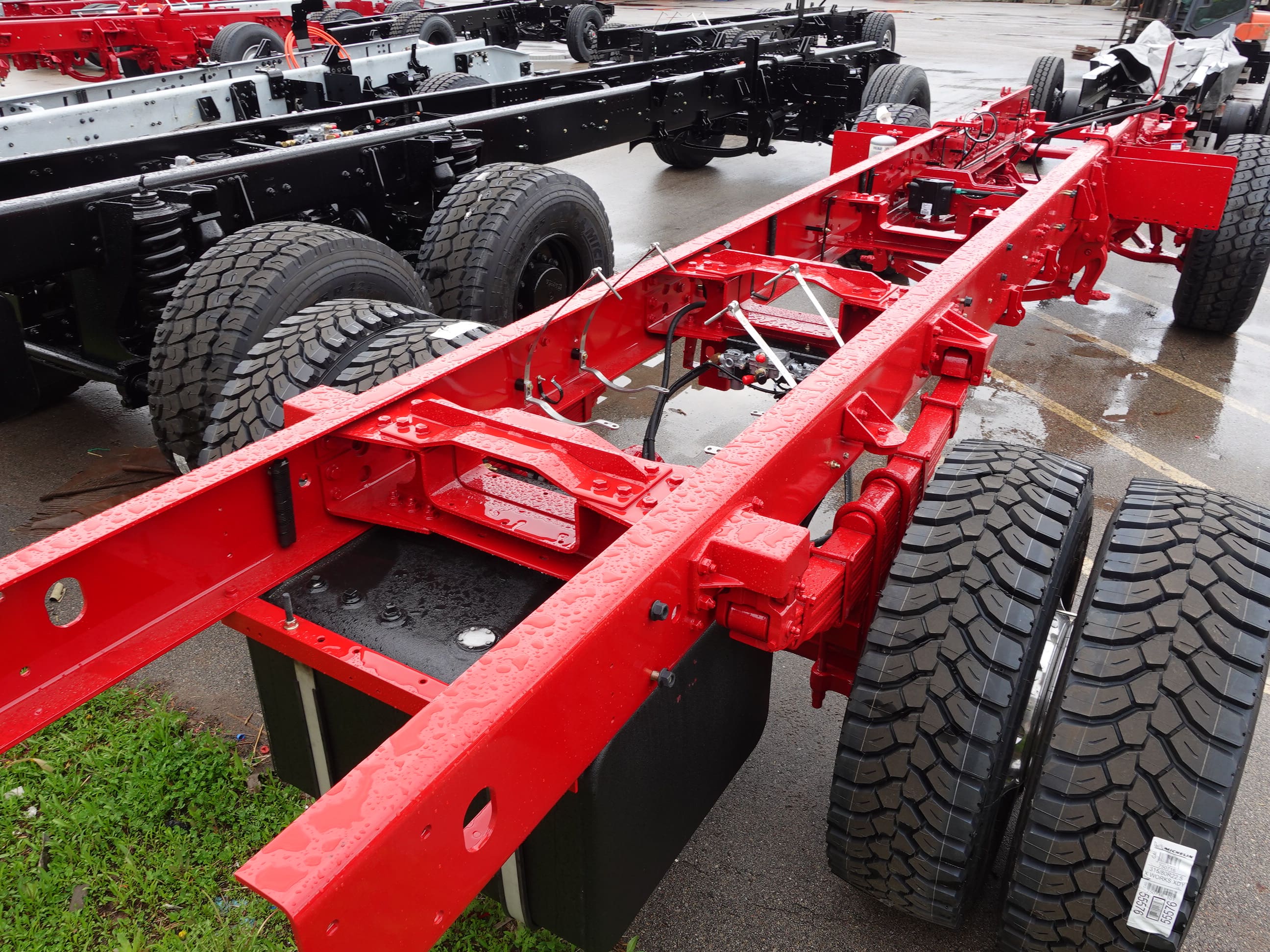

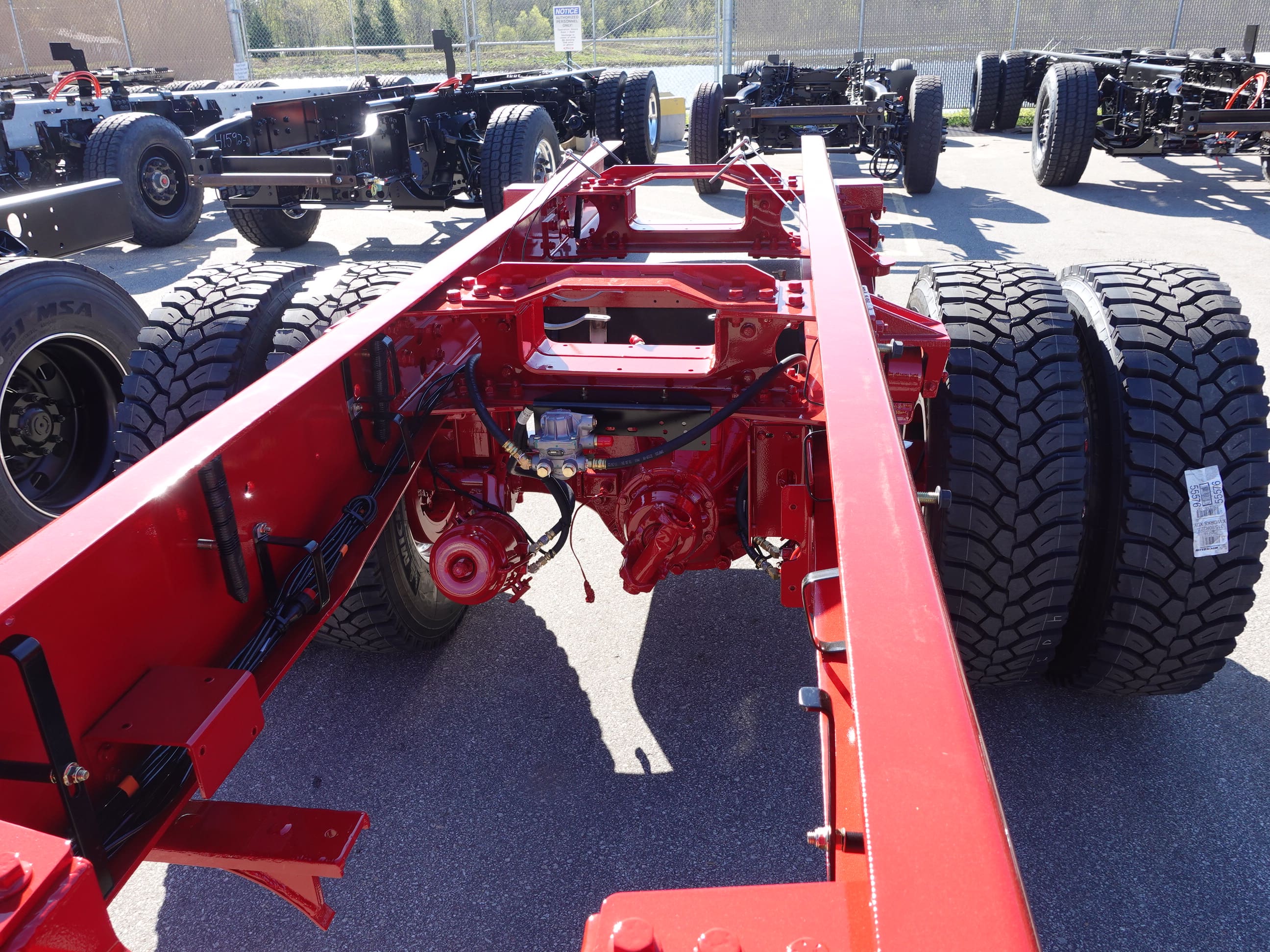

05-08-26

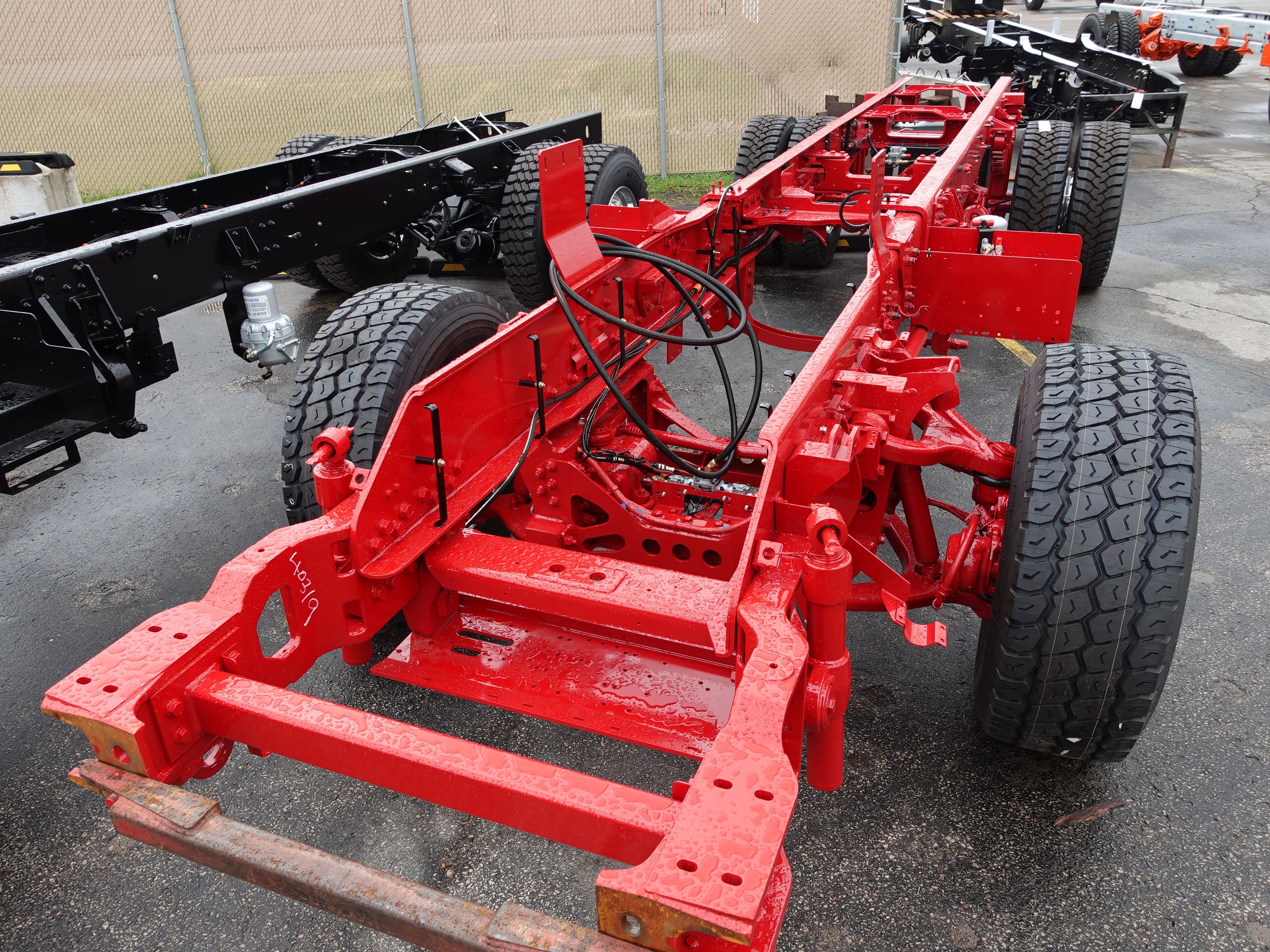

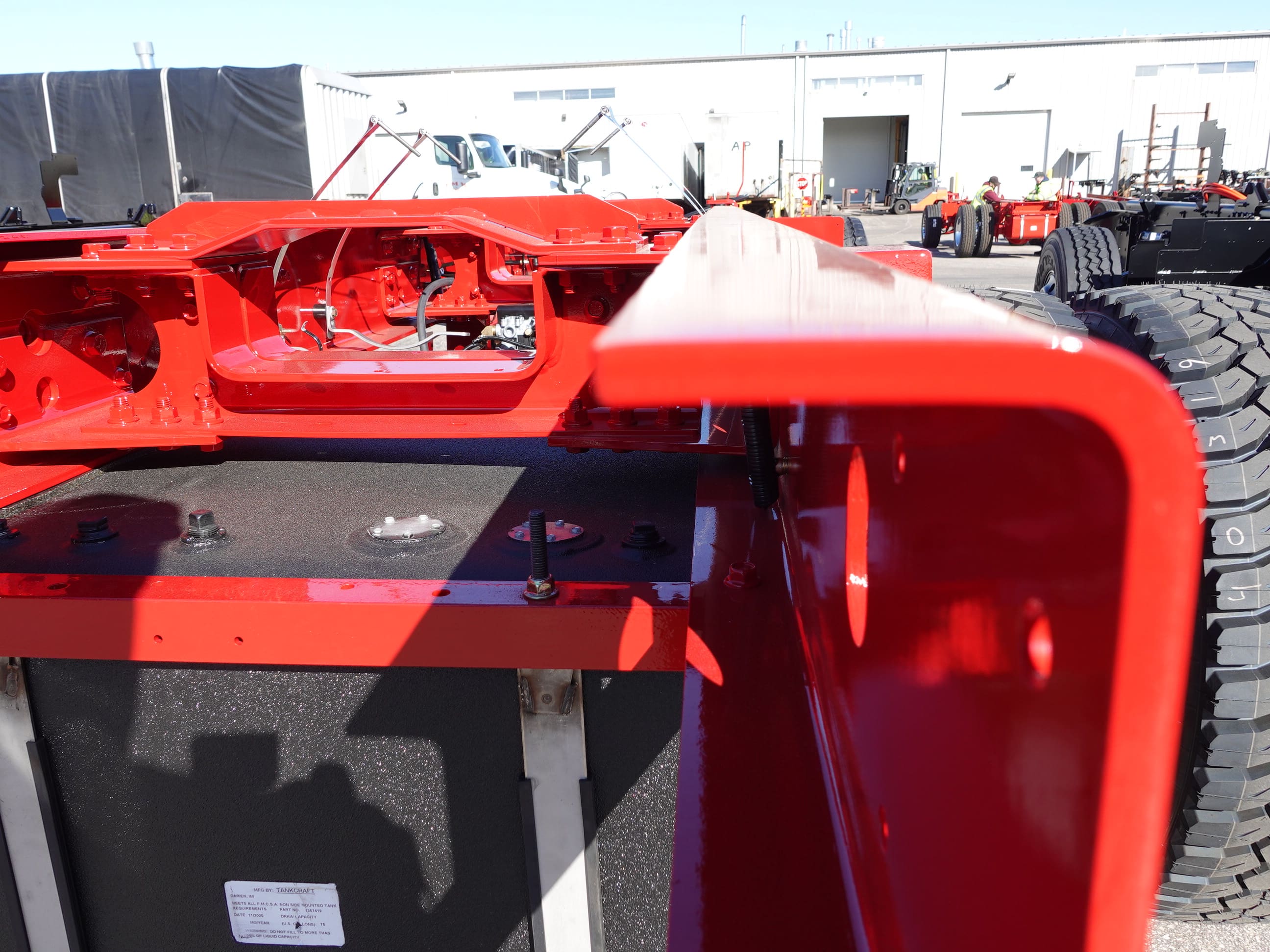

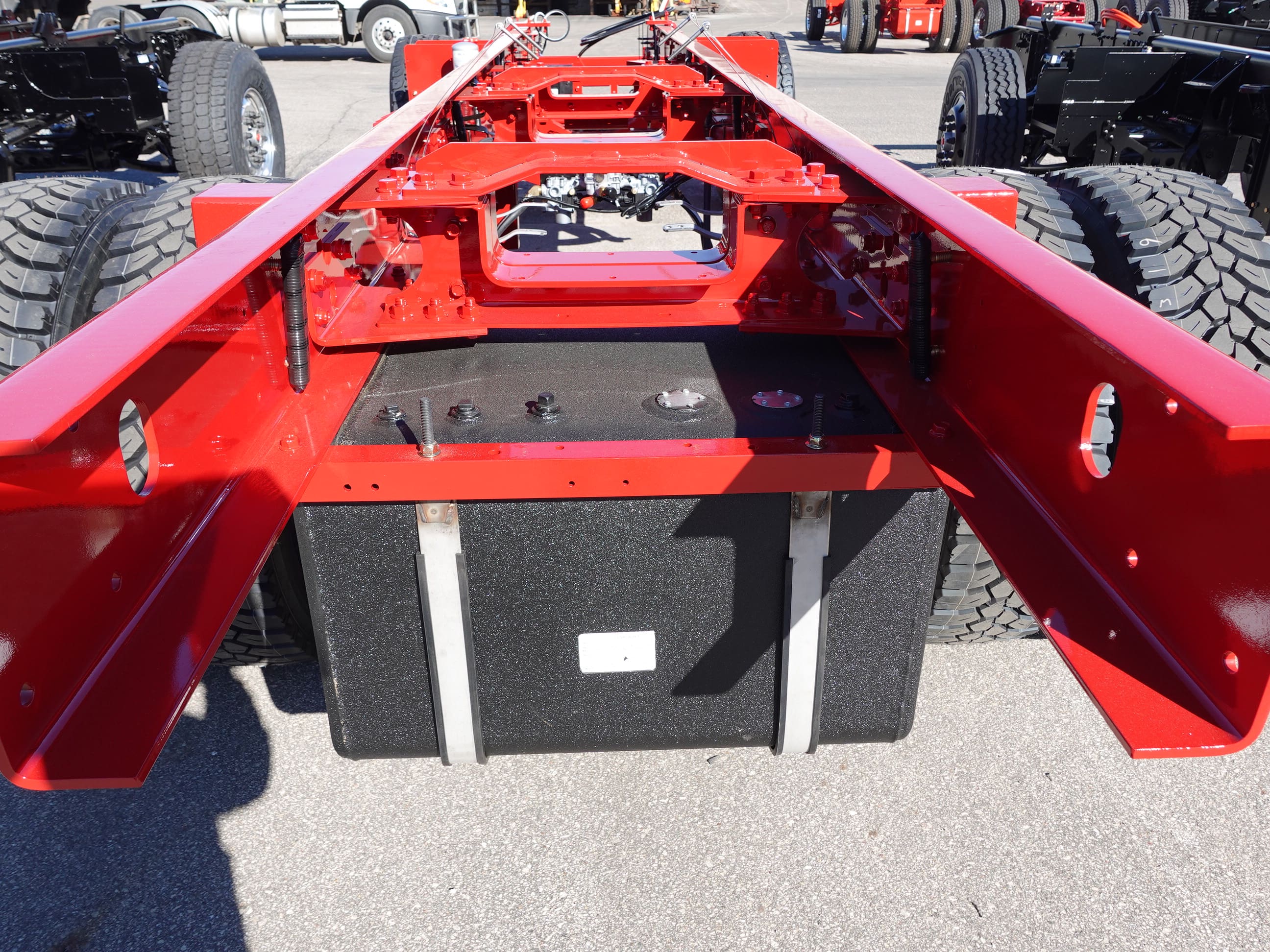

In this report your cab continued through paint, the frame build began, and the body continued the
fabrication process.

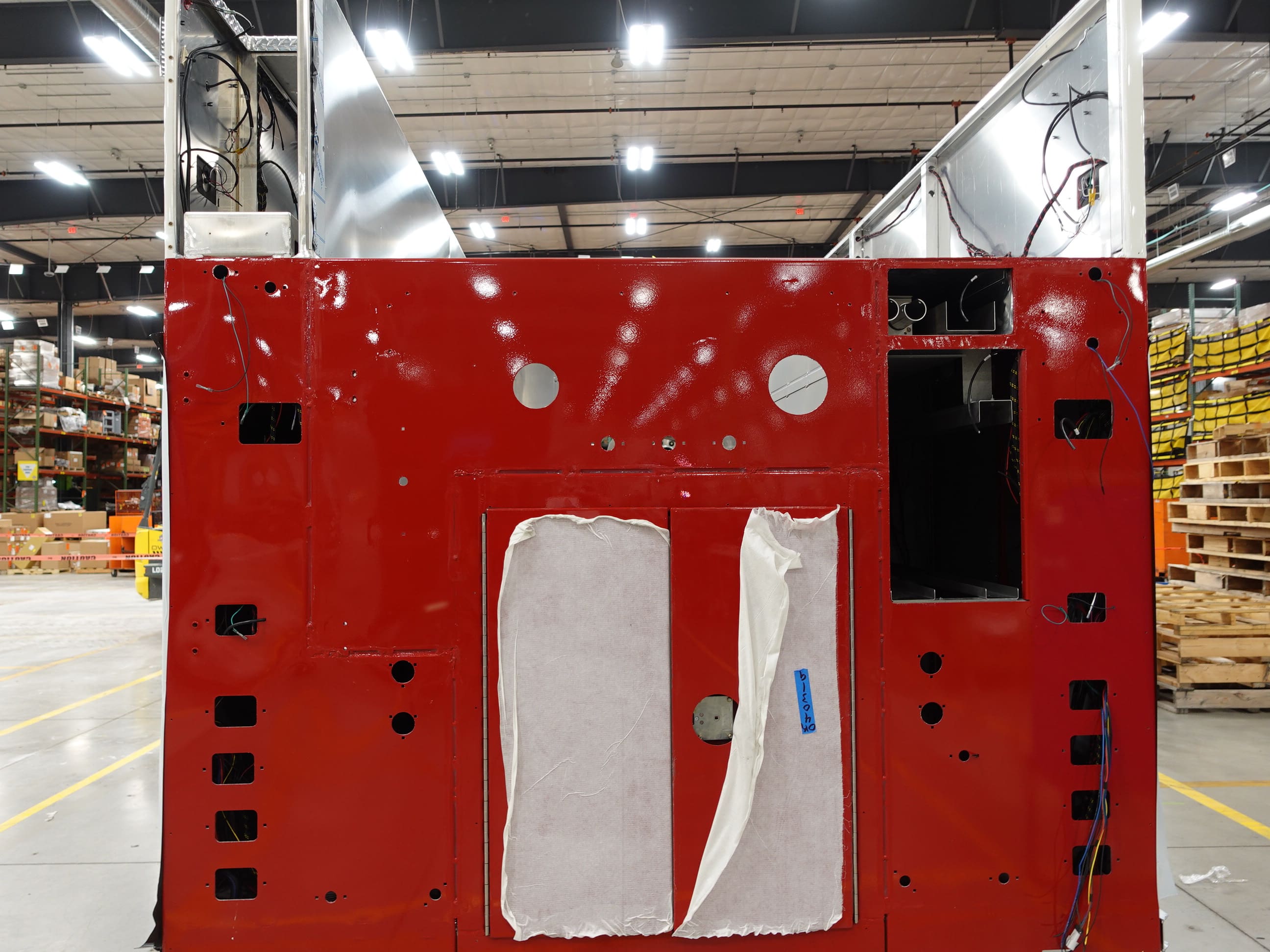

05-01-26

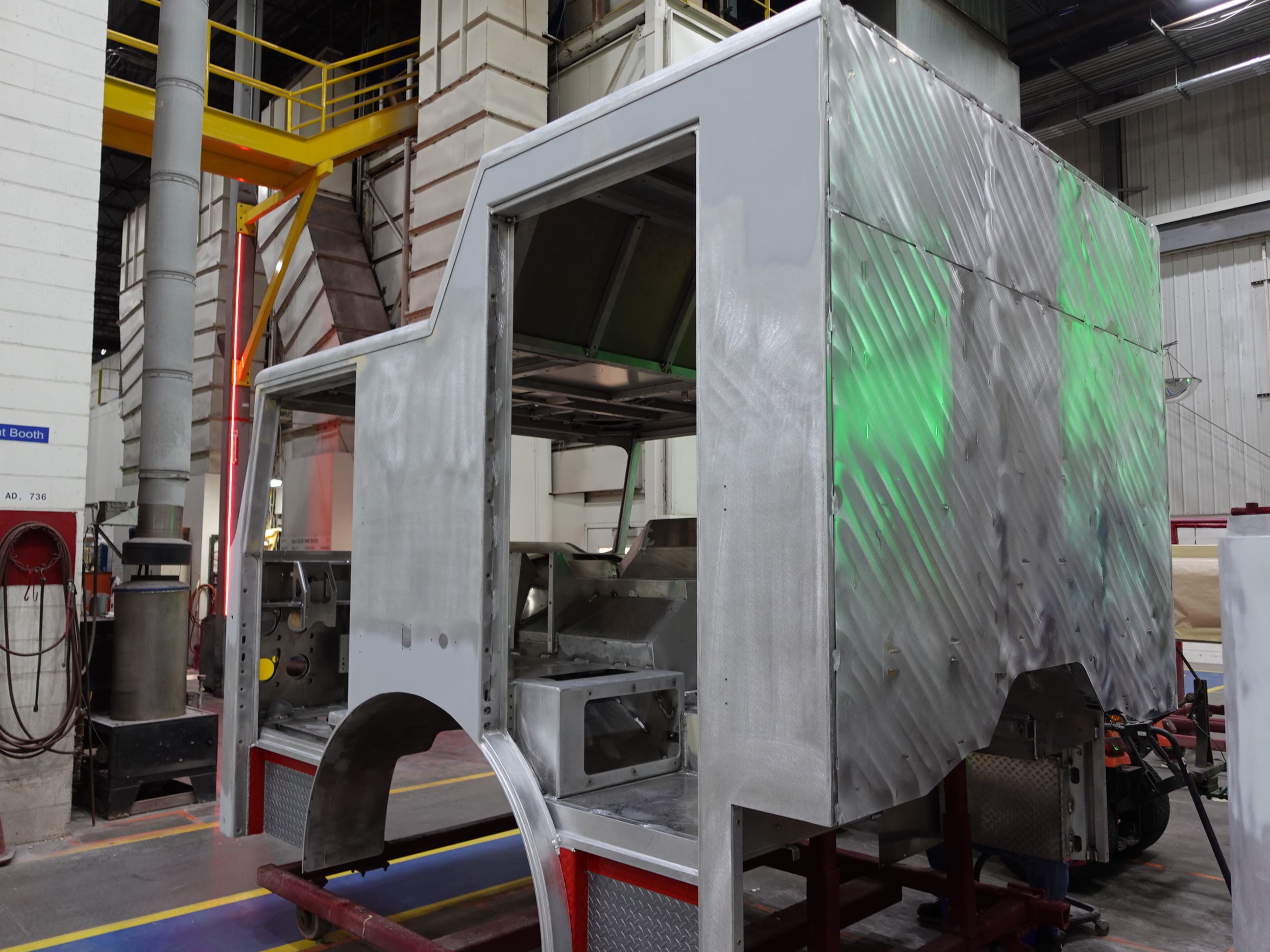

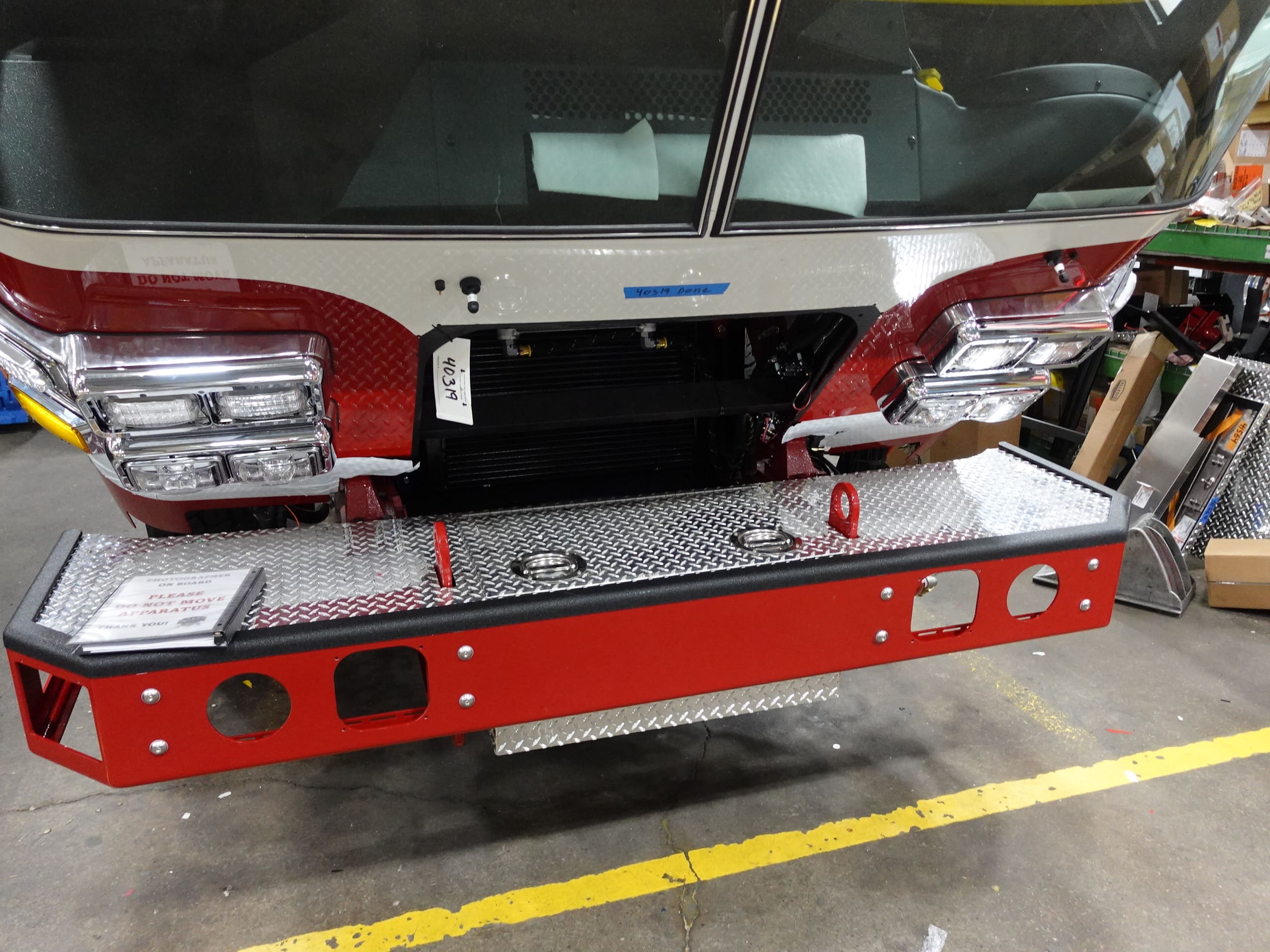

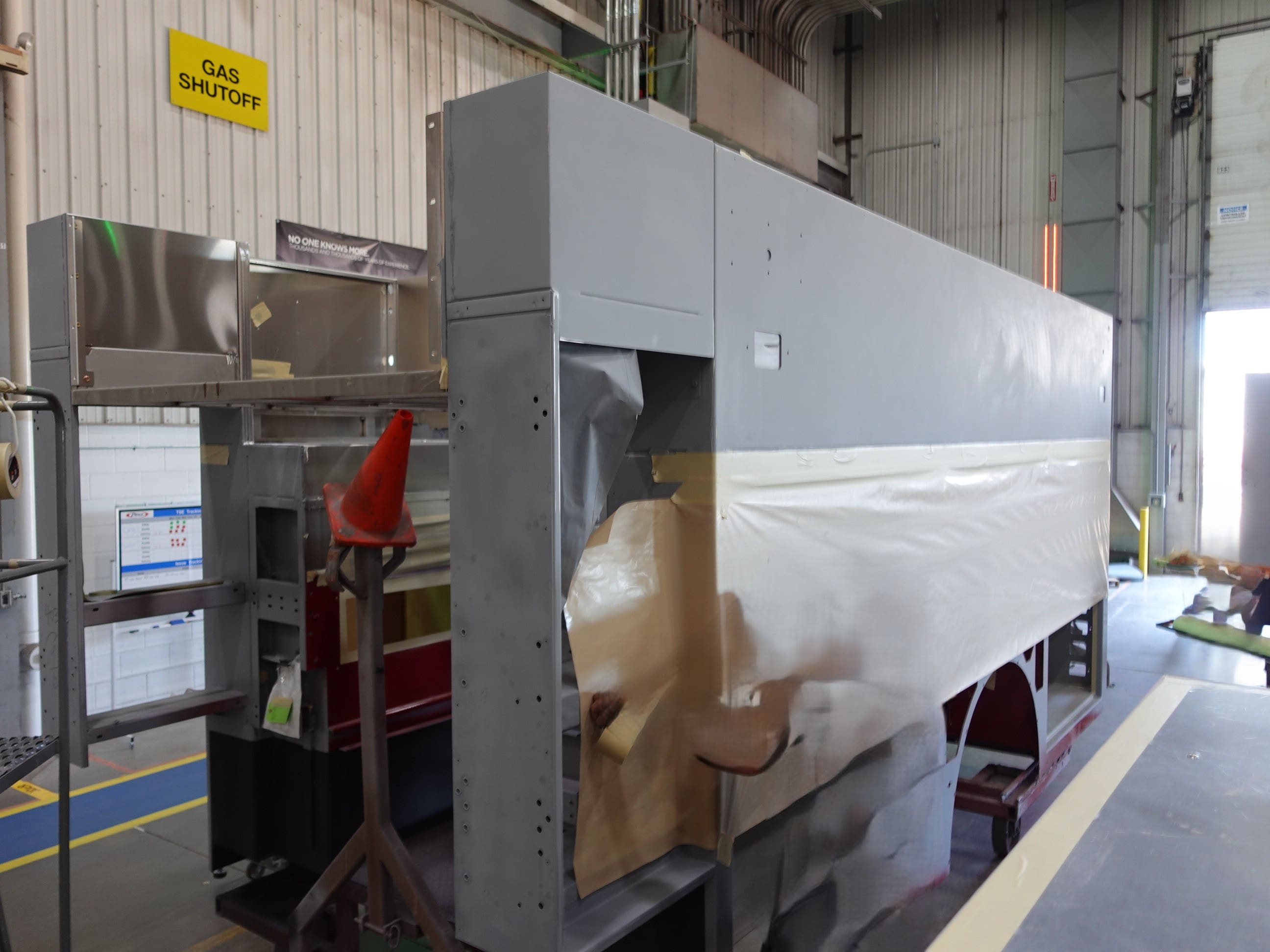

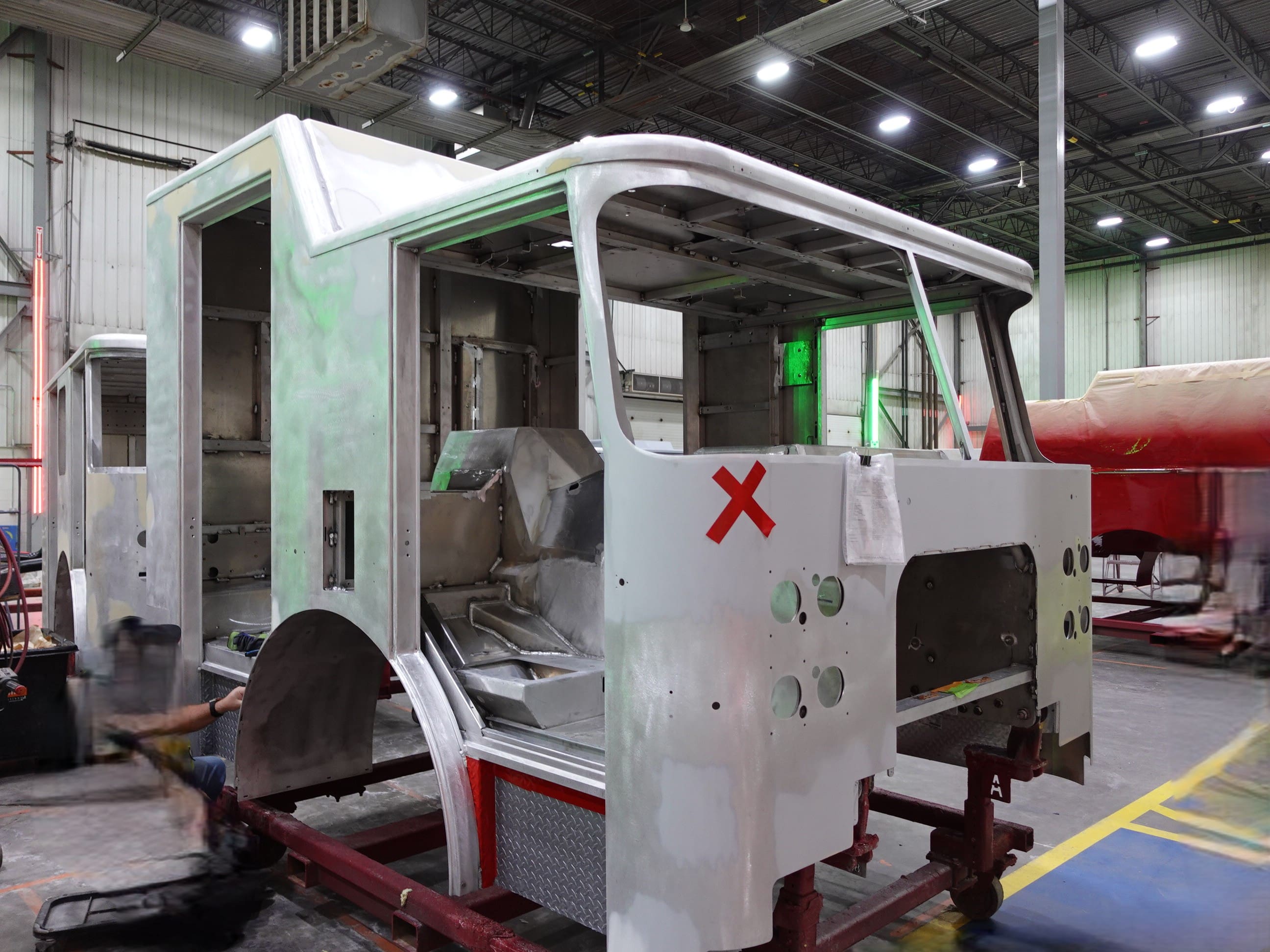

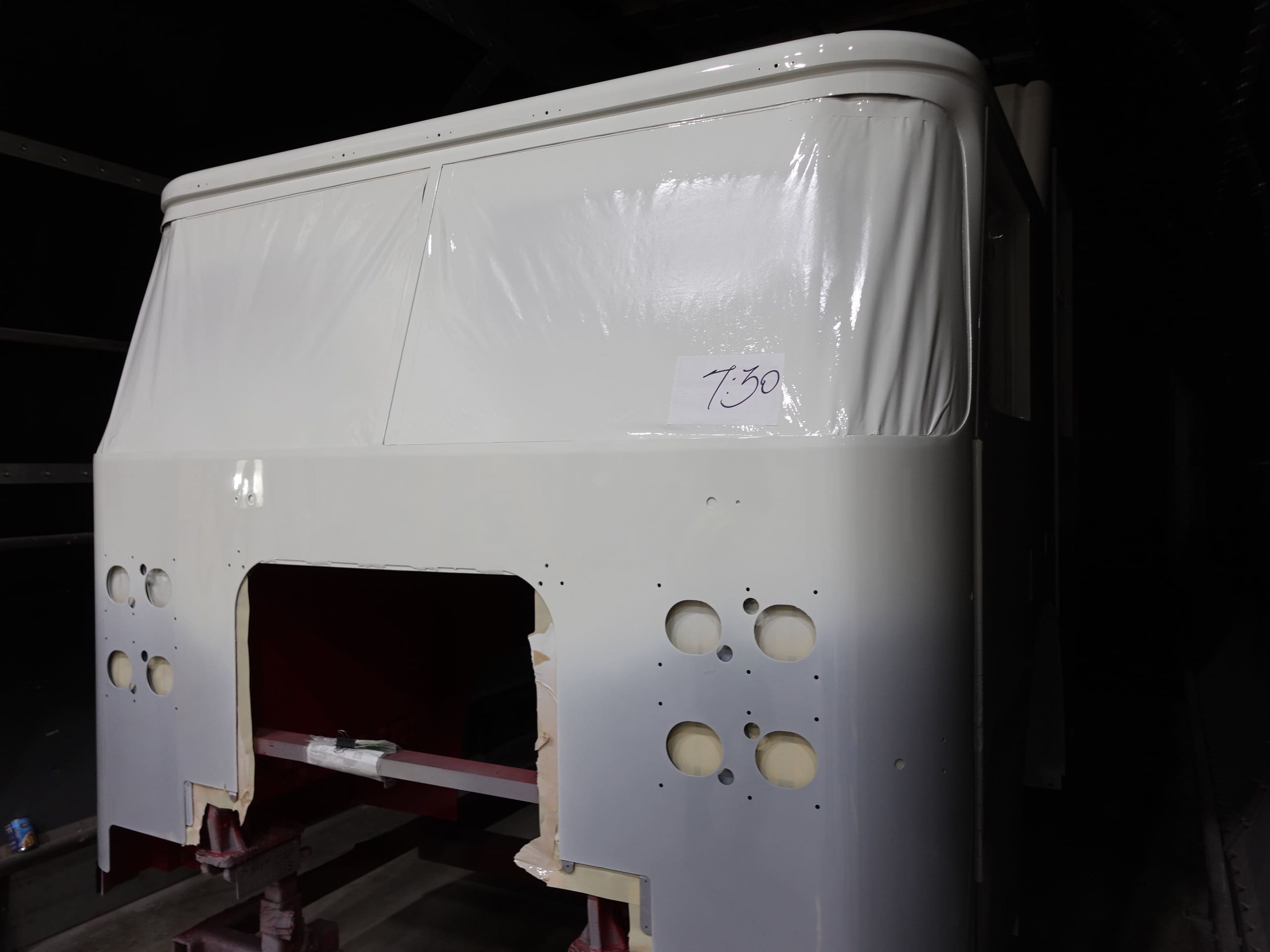

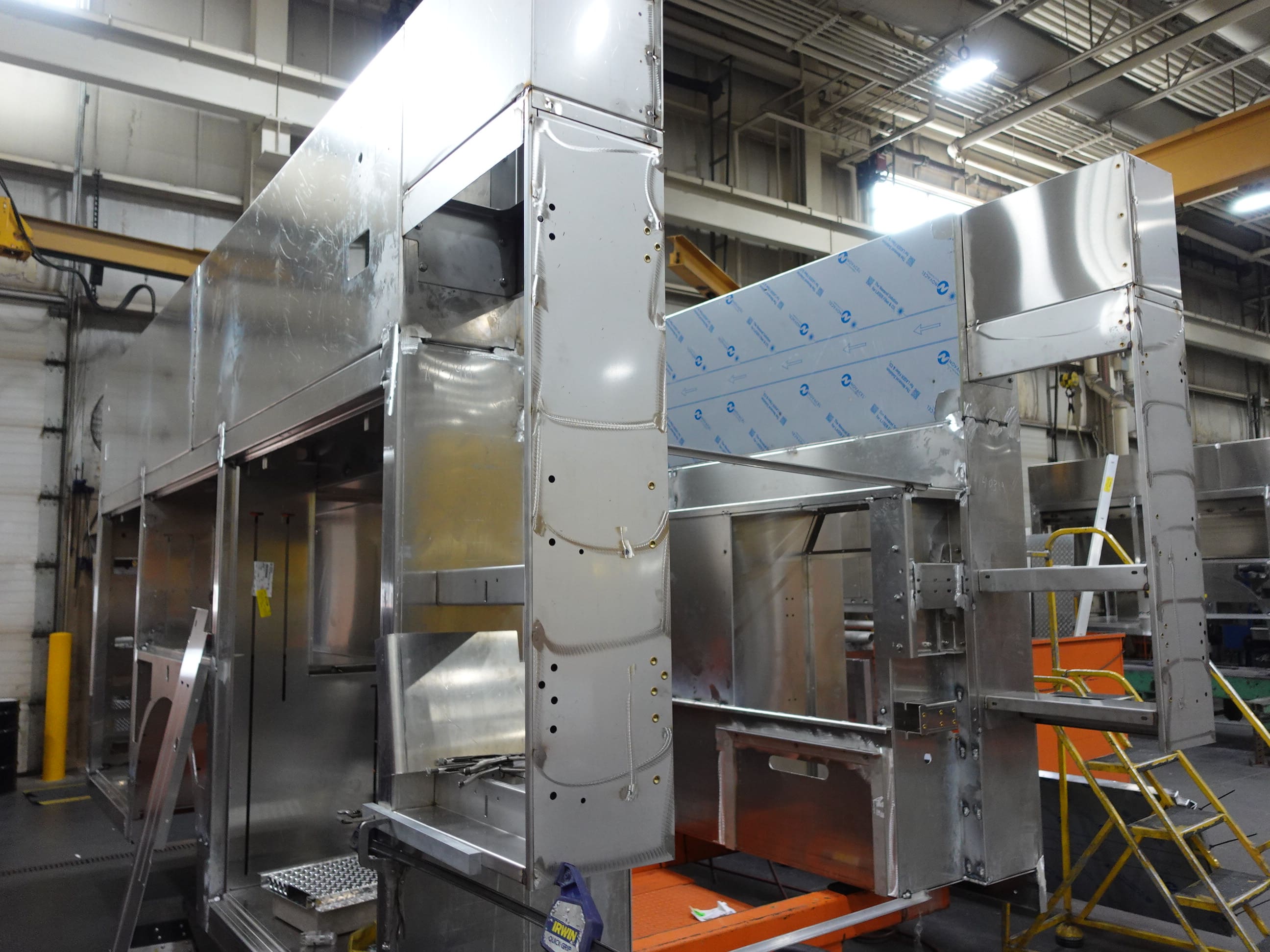

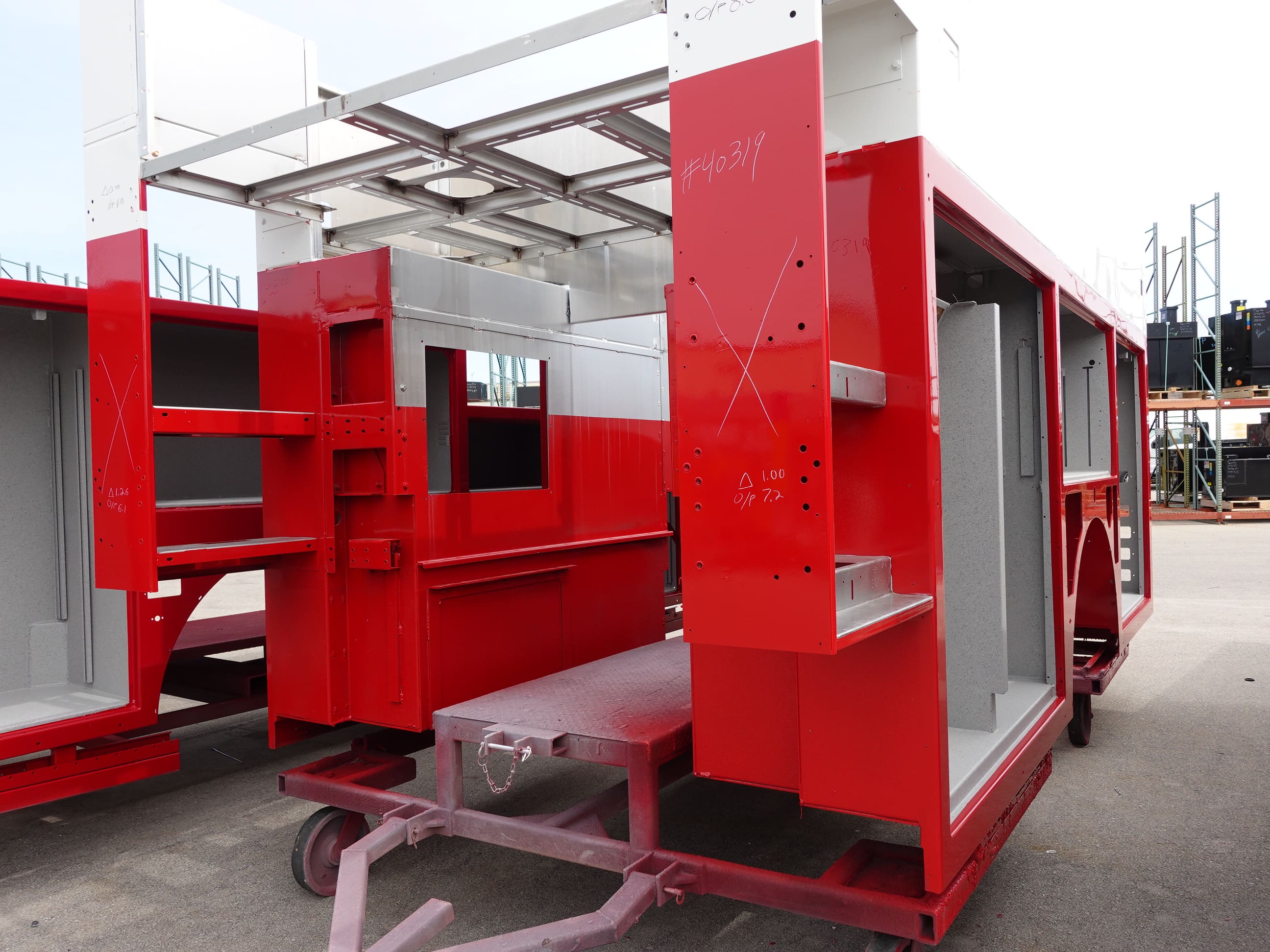

In this report, the cab completed fabrication and began the paint process while the body began fabrication.
04-24-26

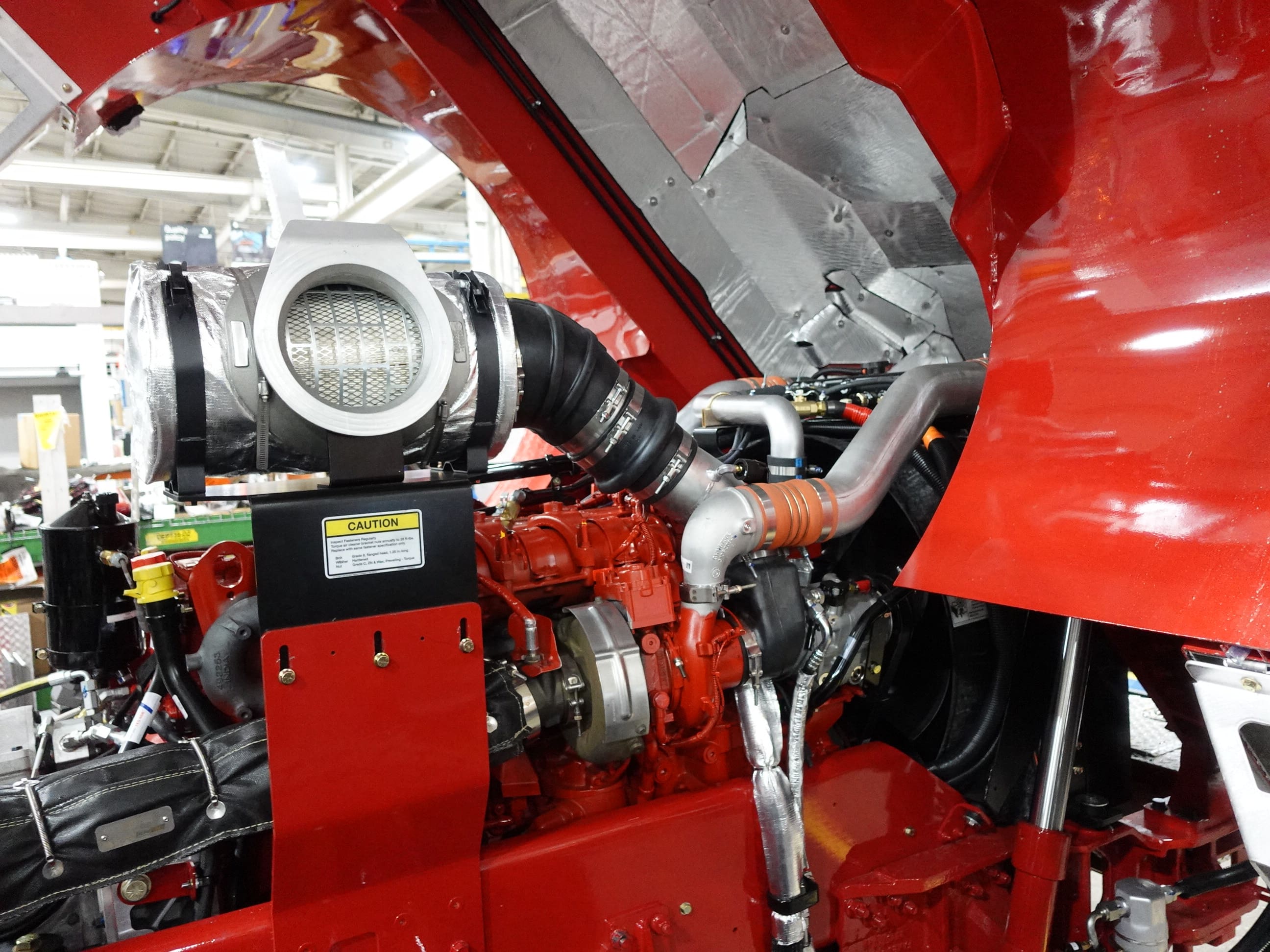

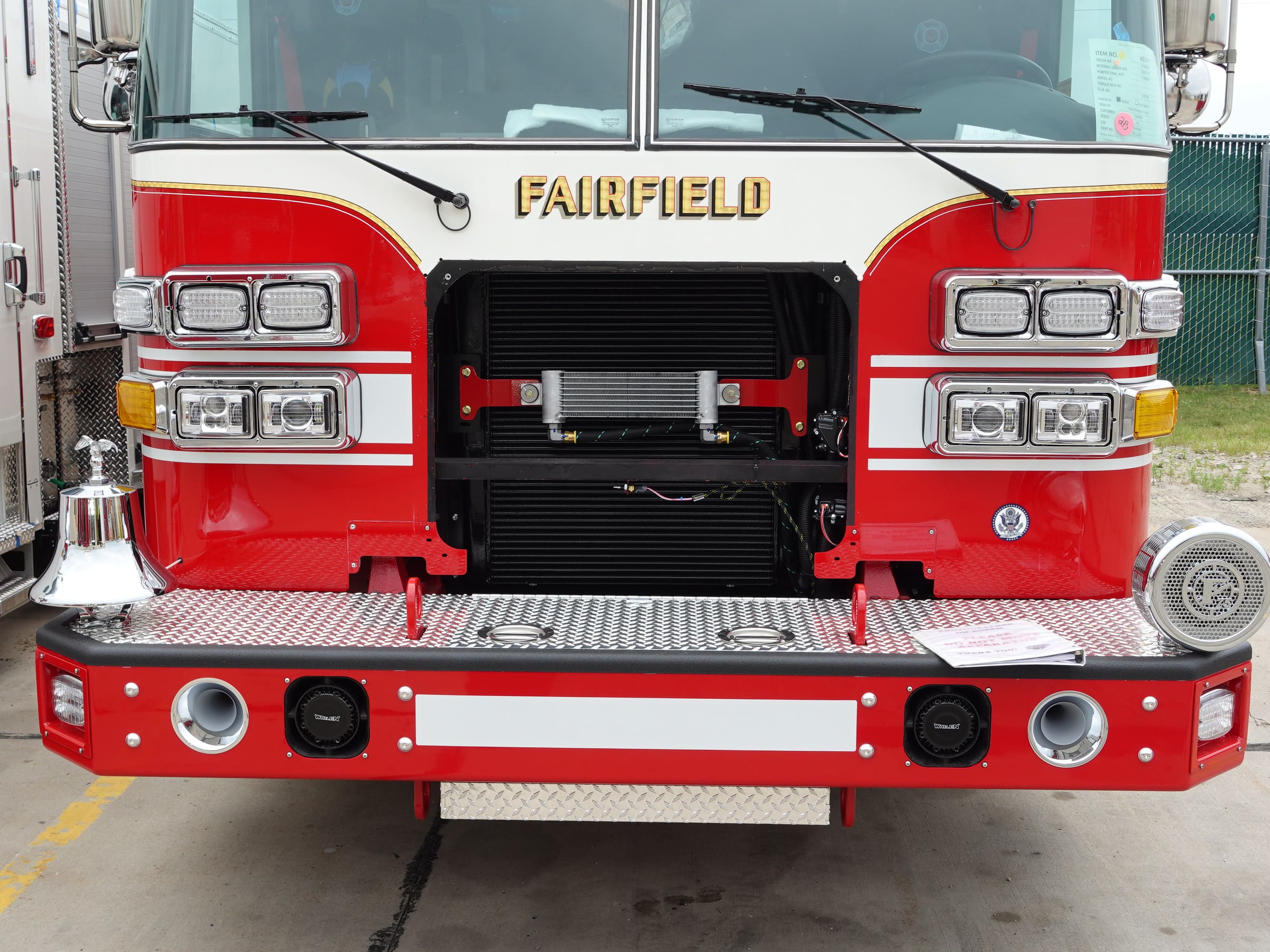

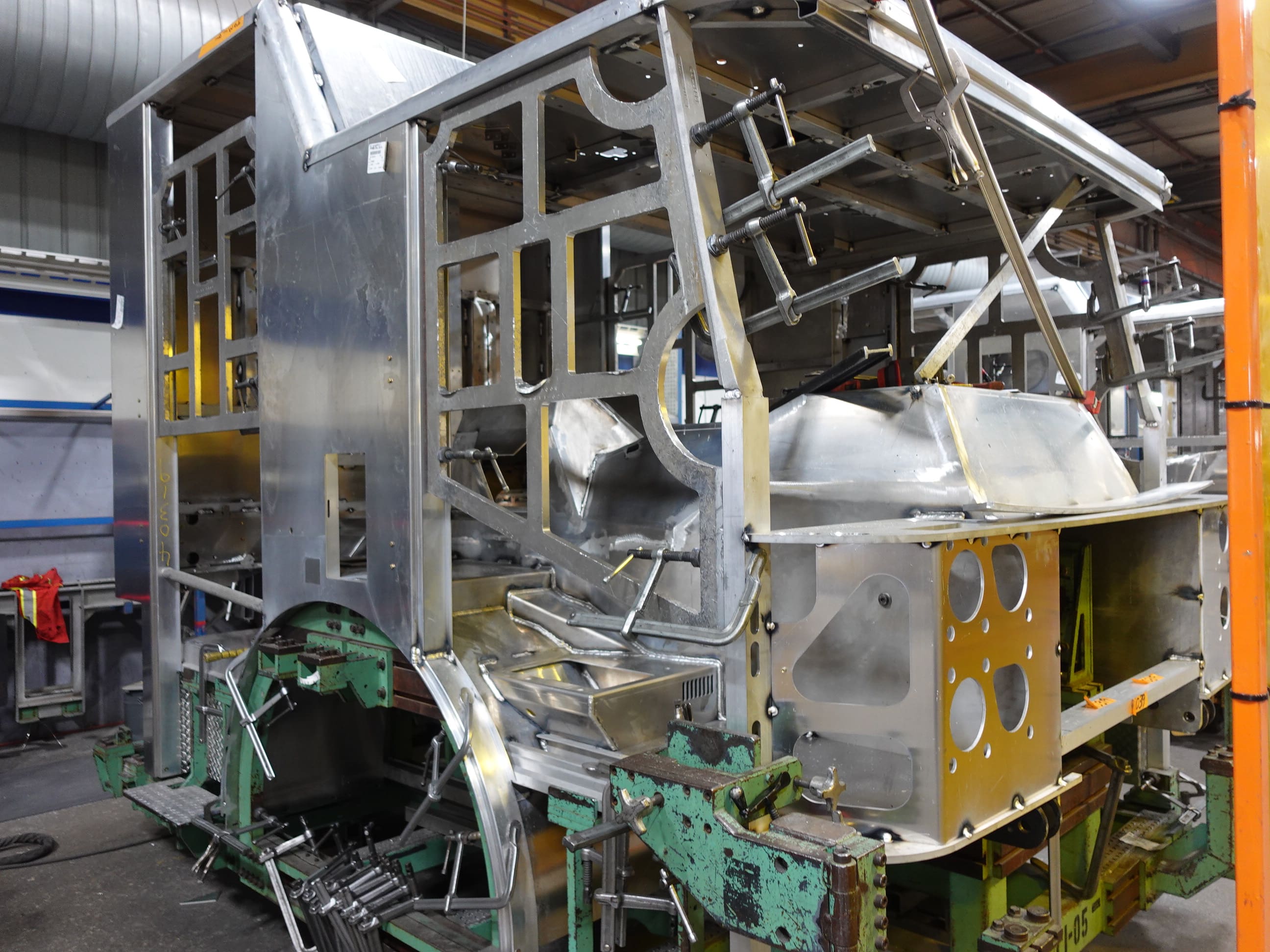

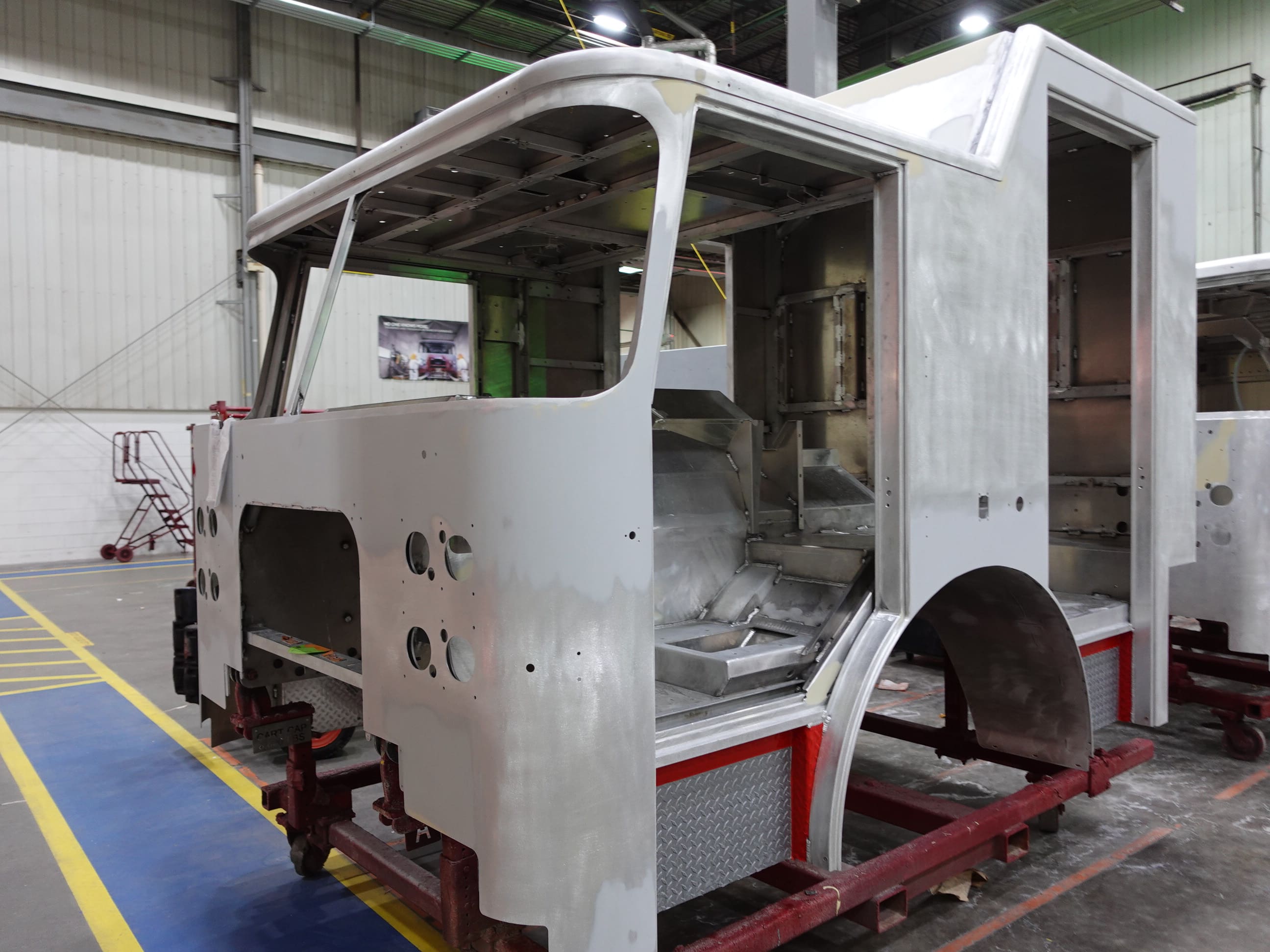

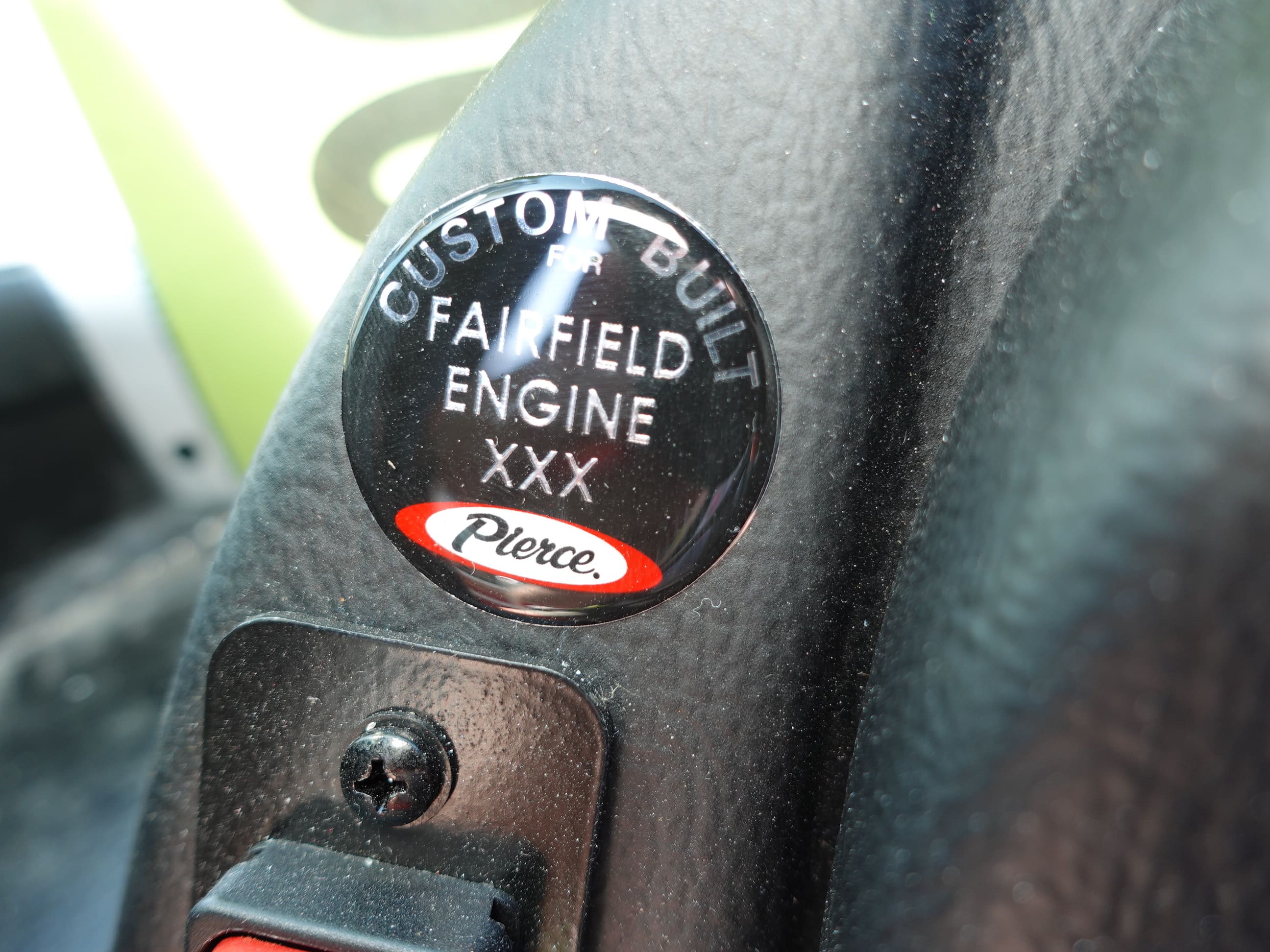

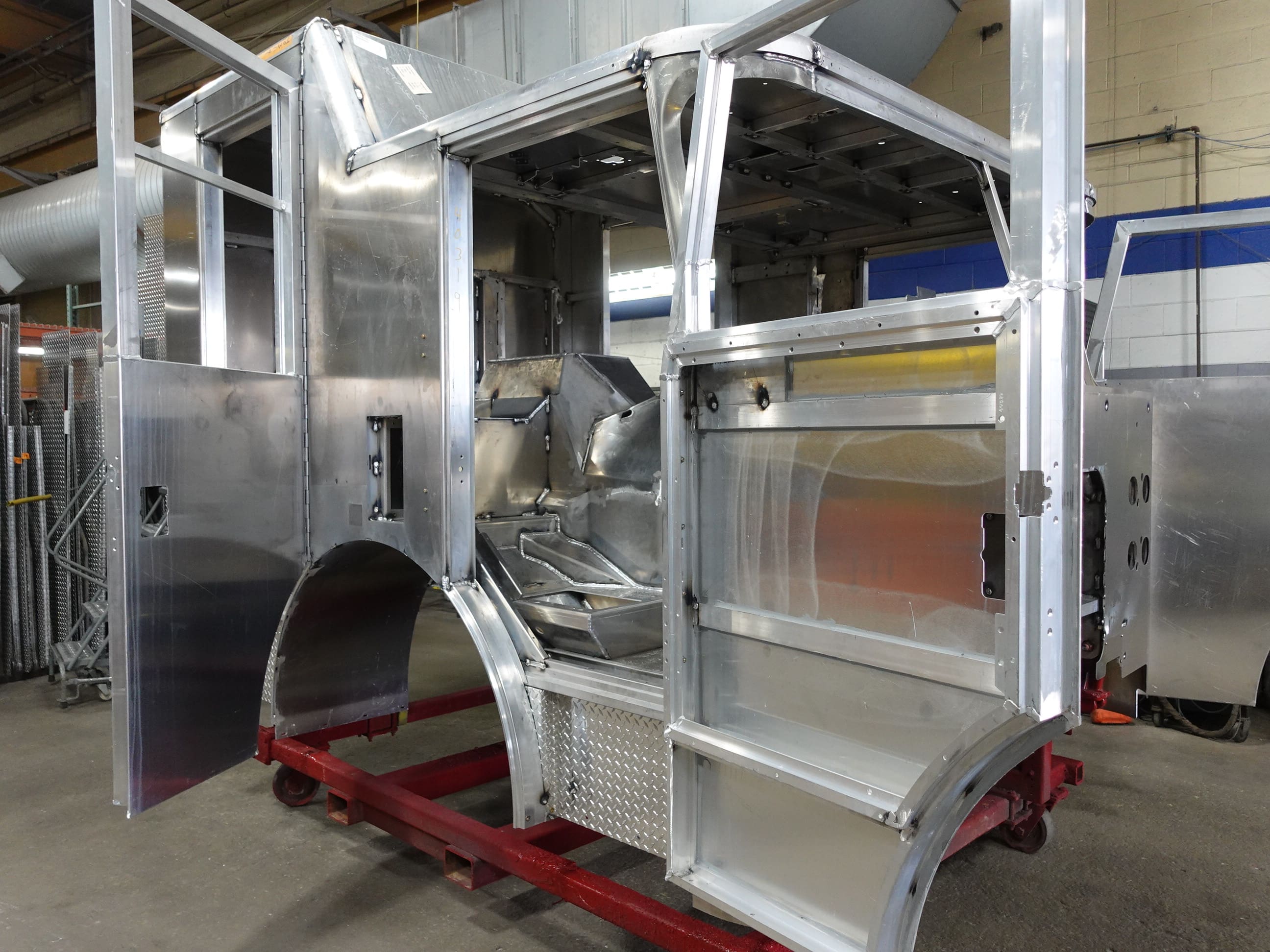

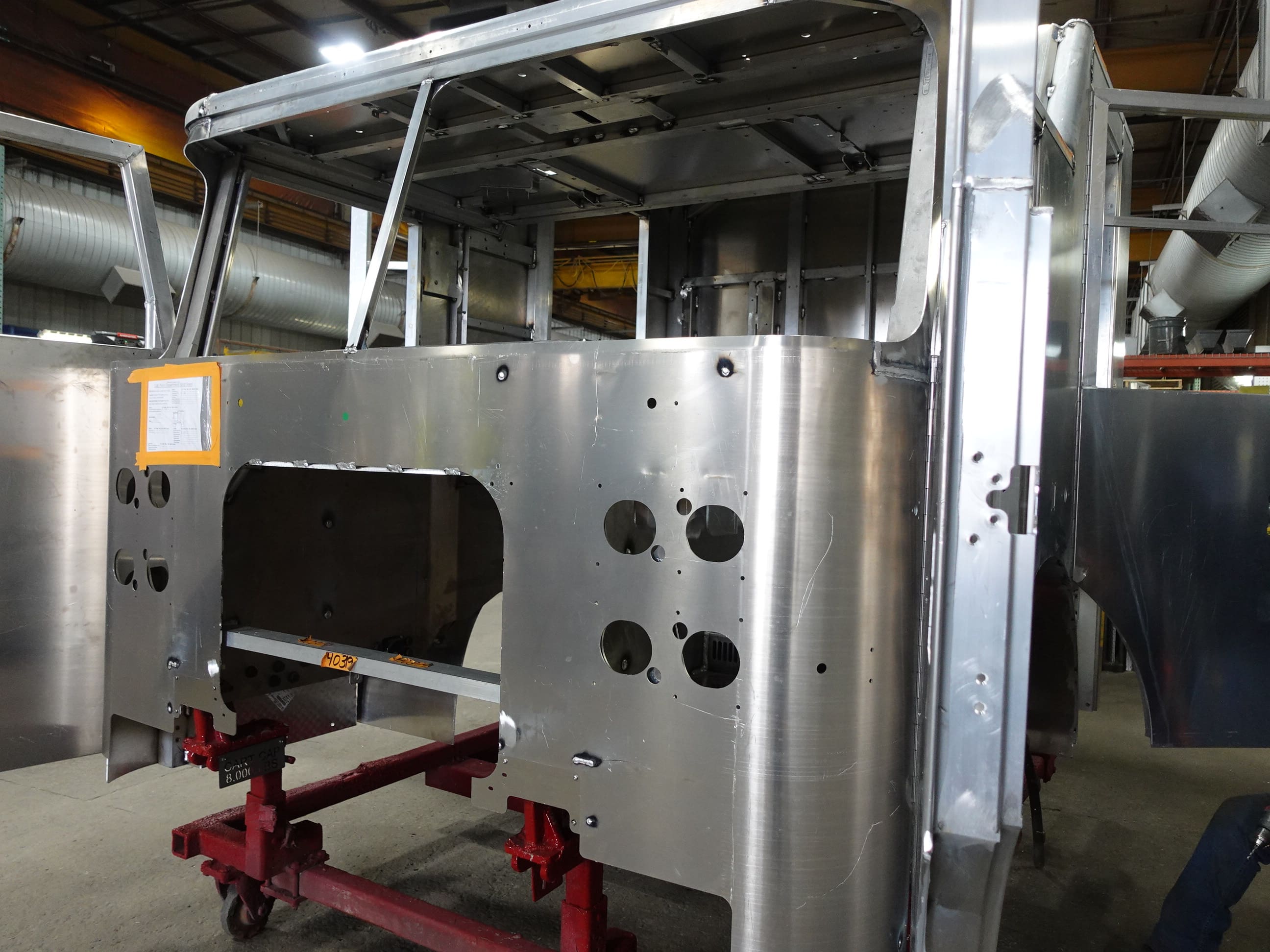

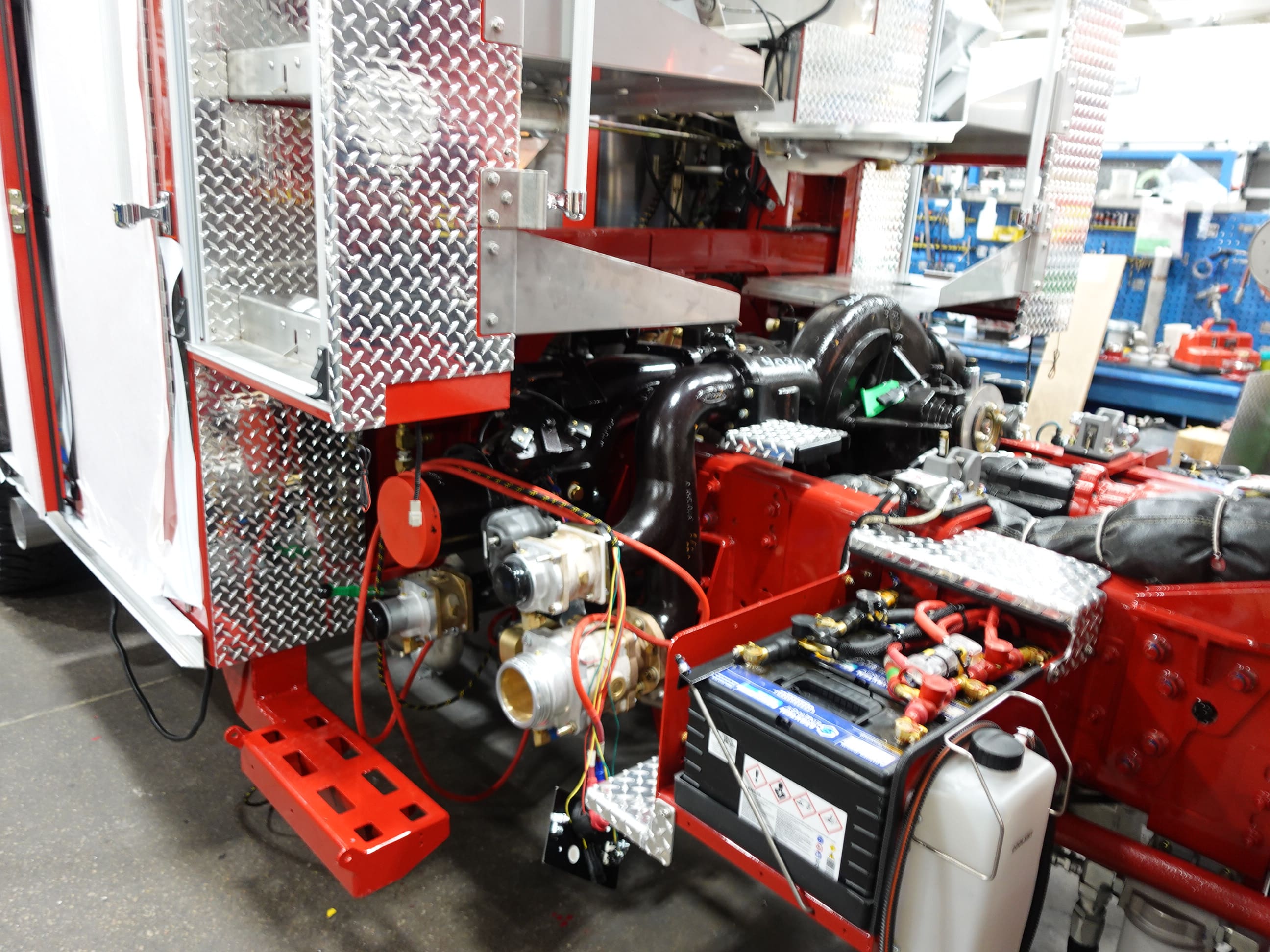

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
