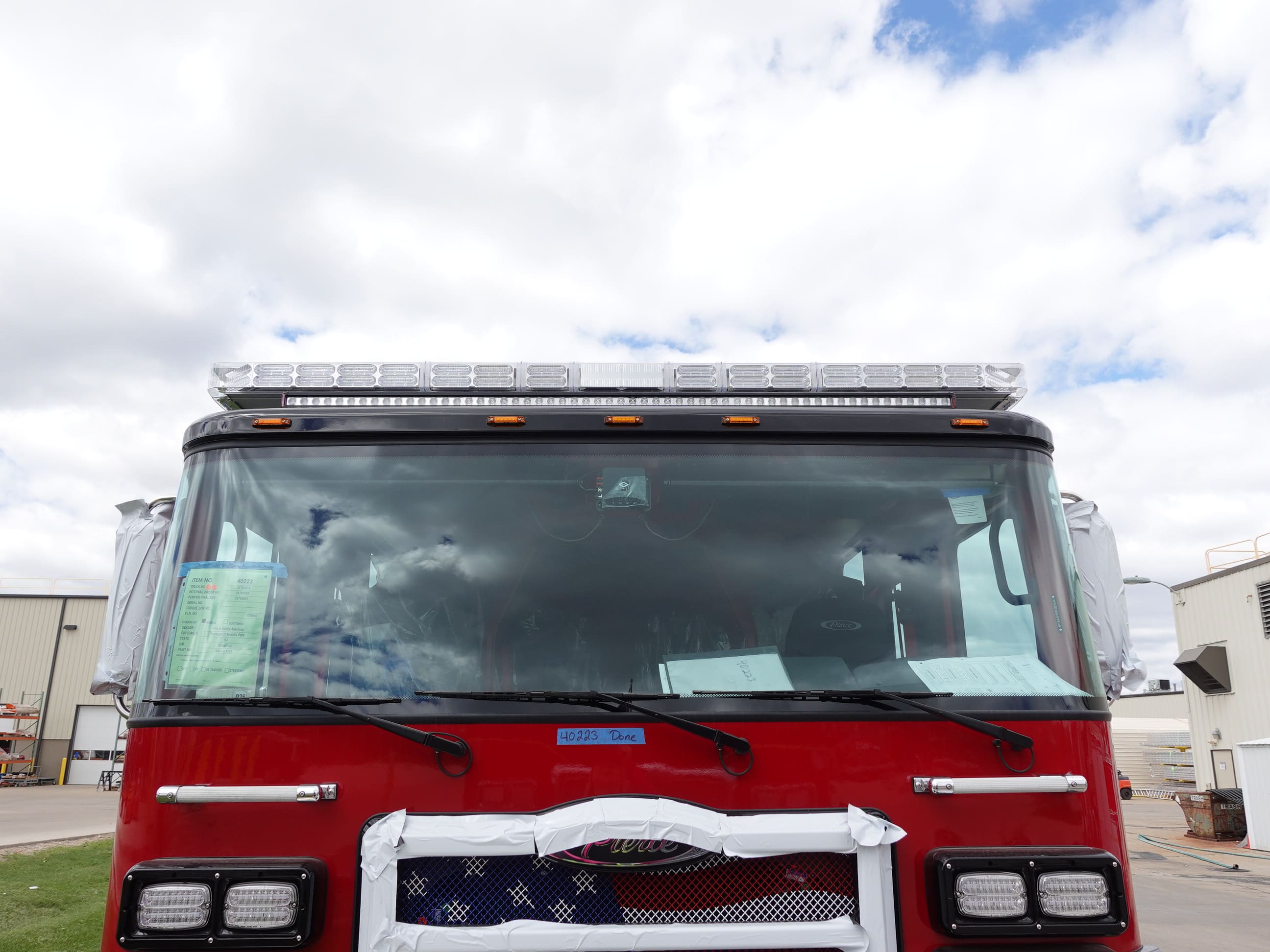

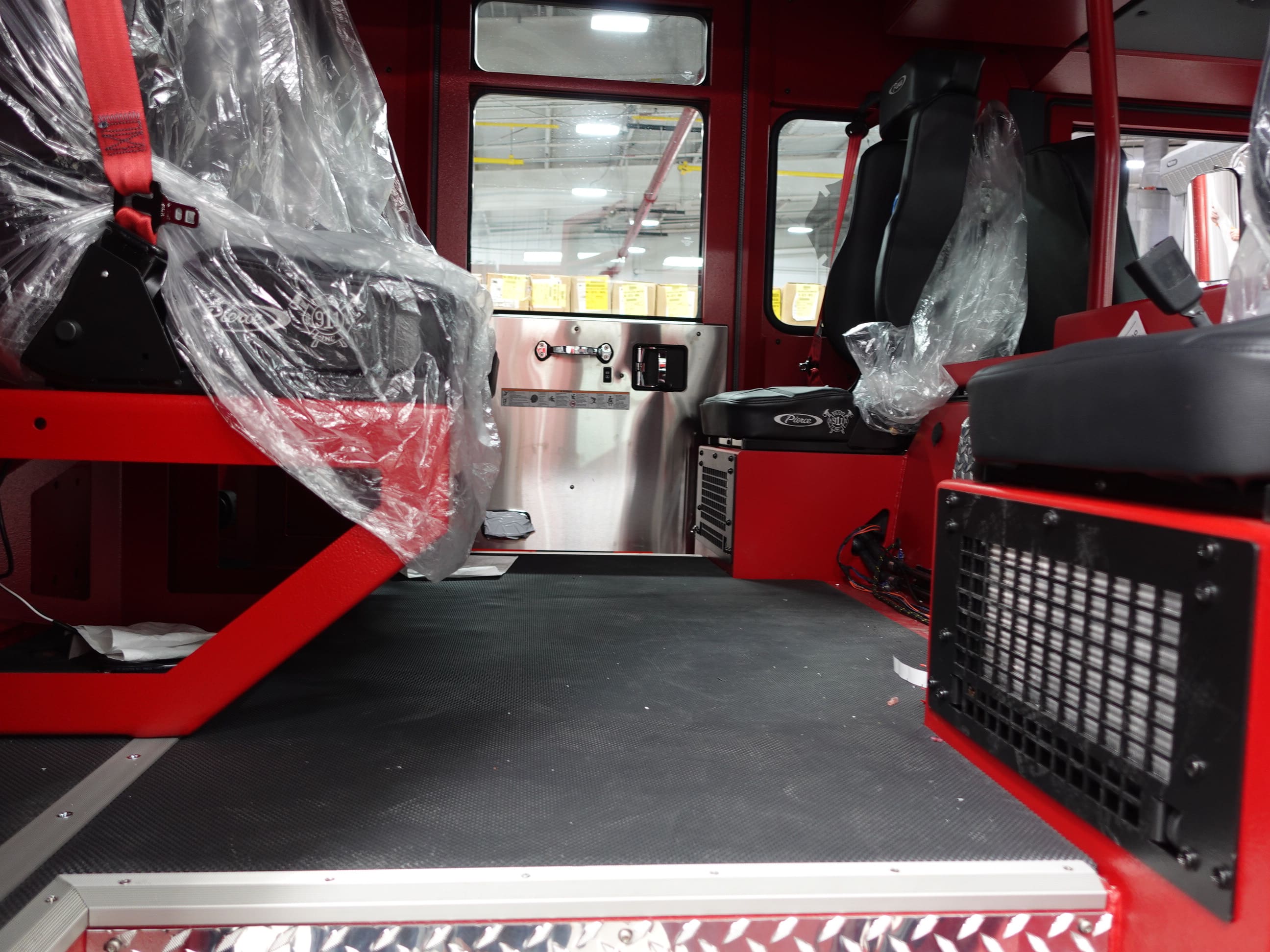

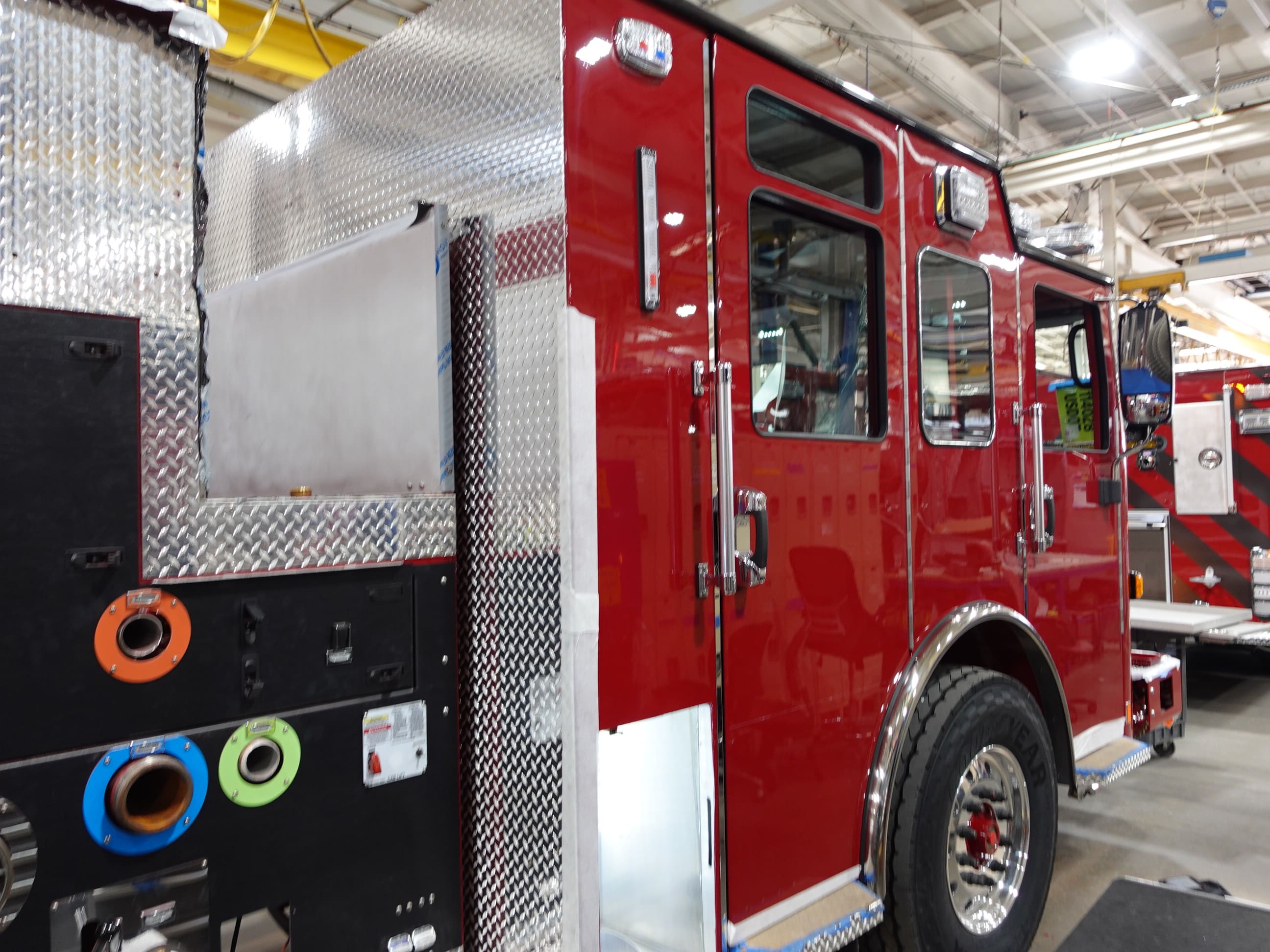

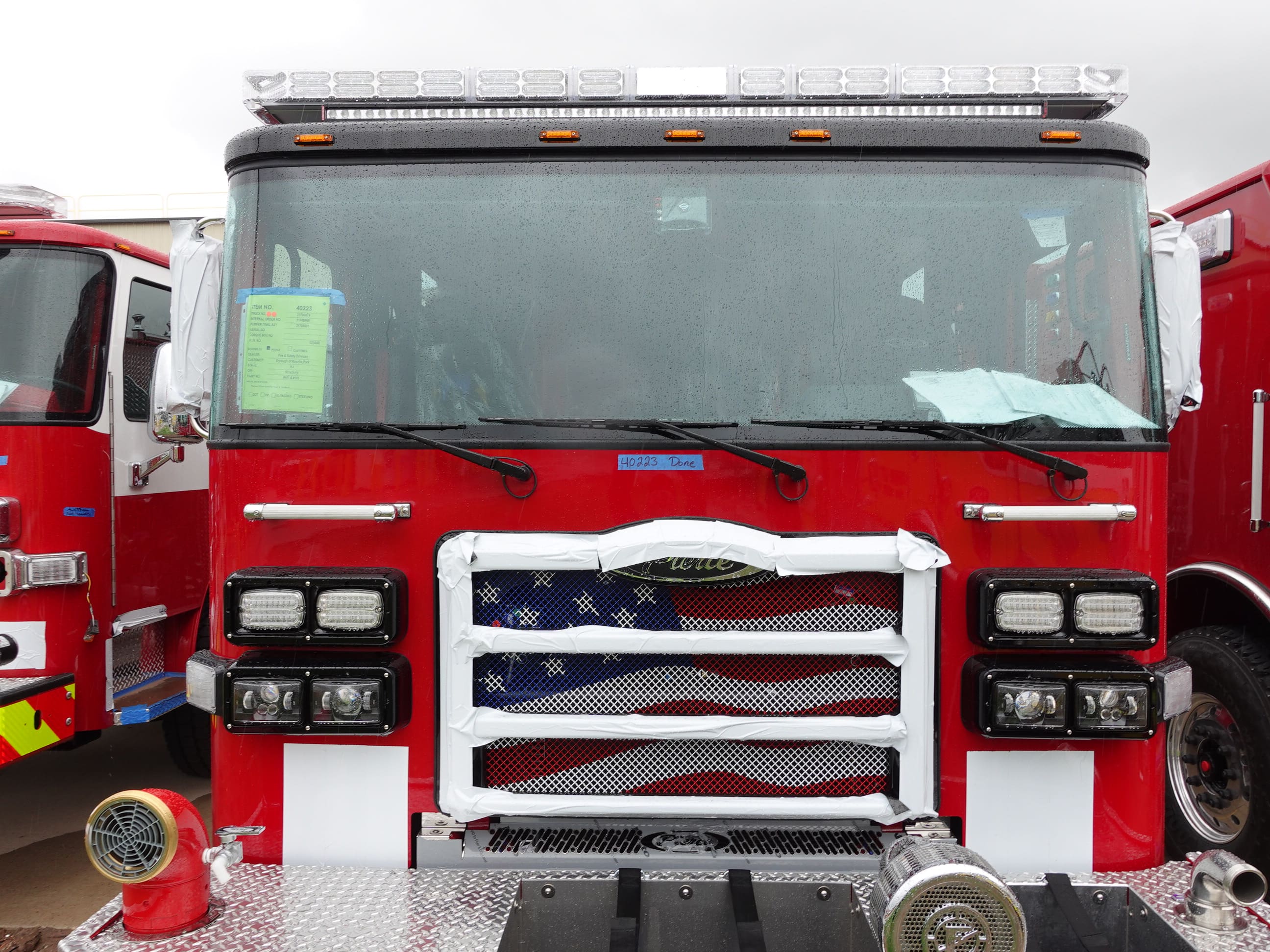

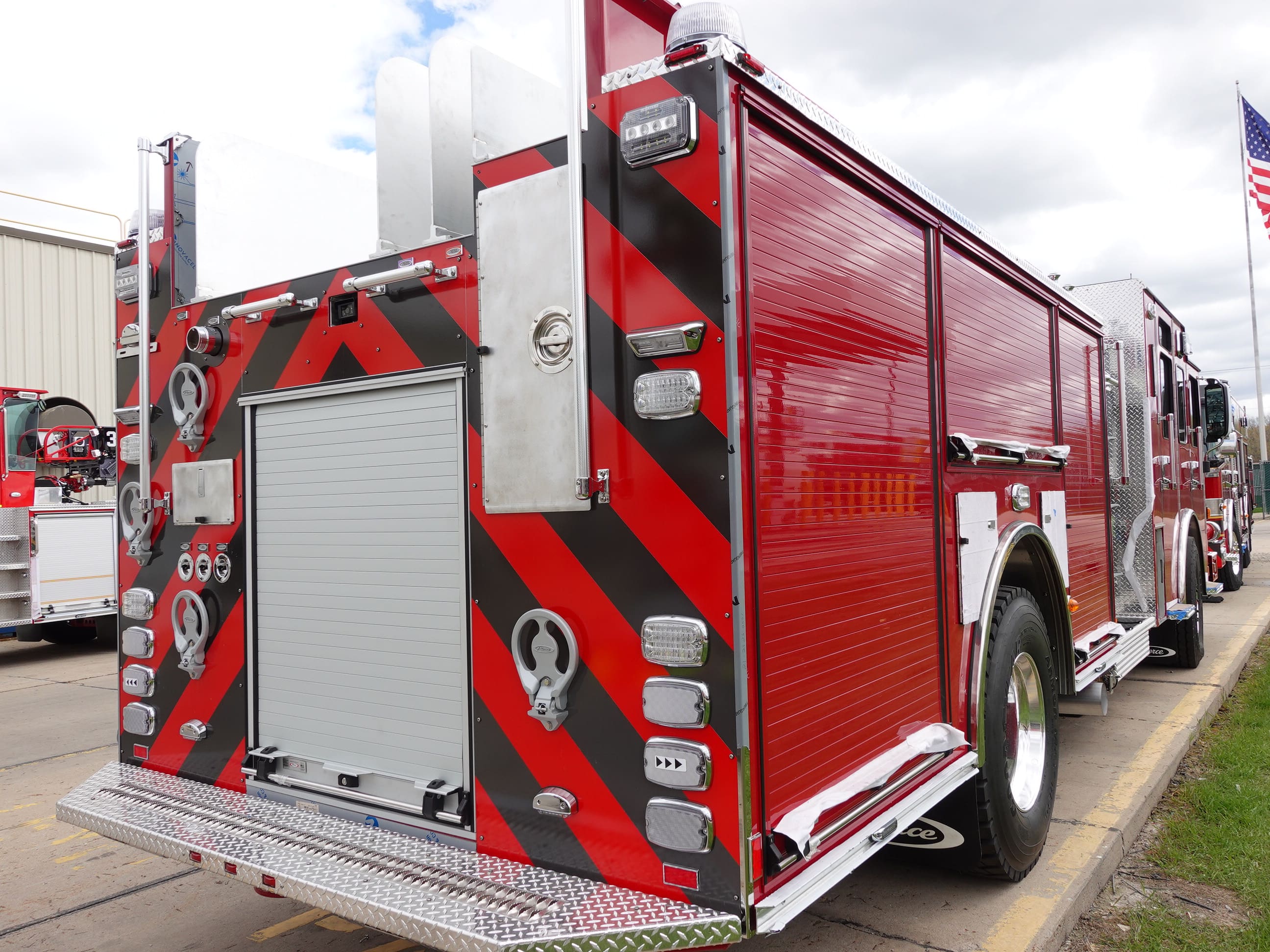

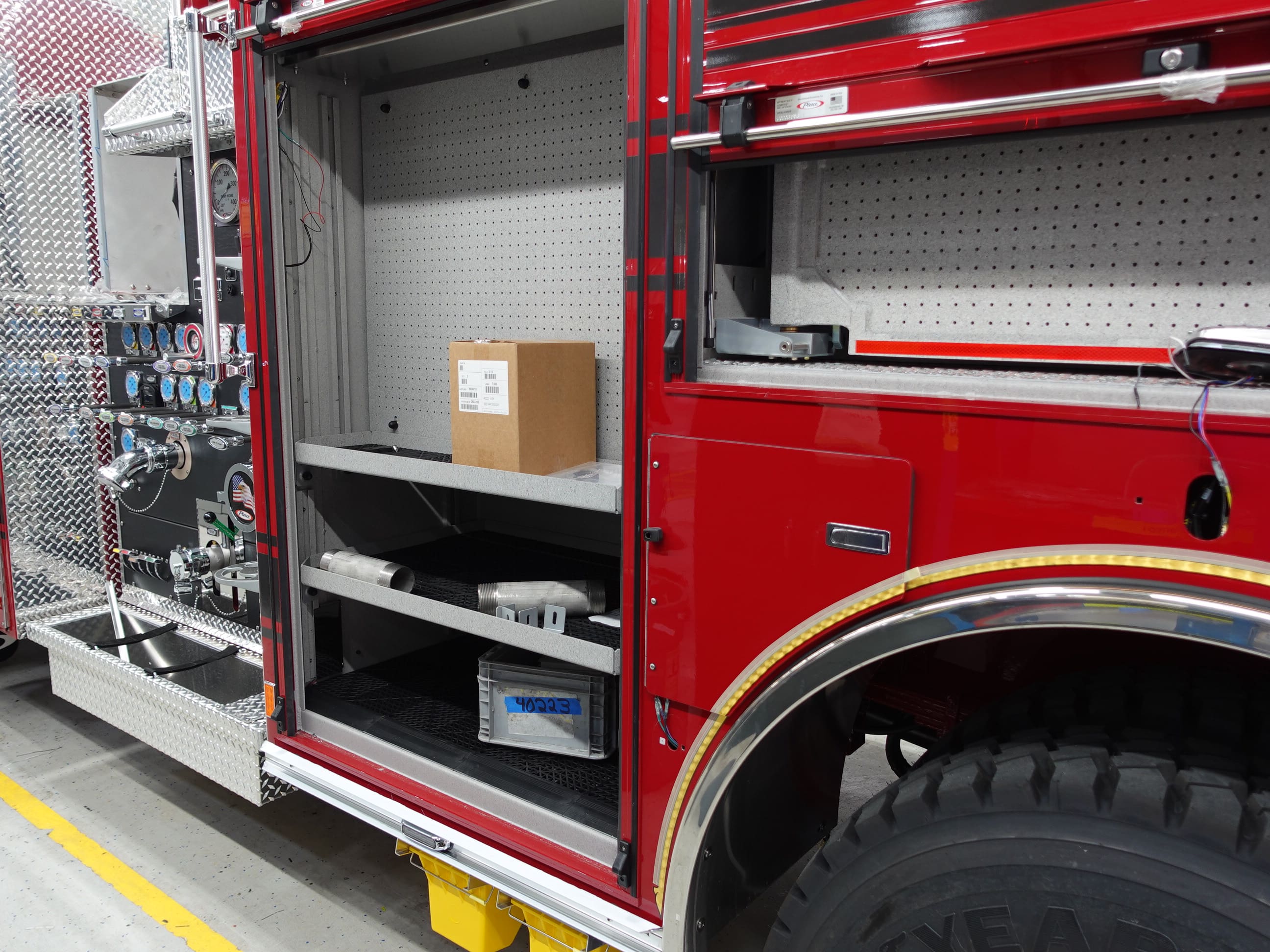

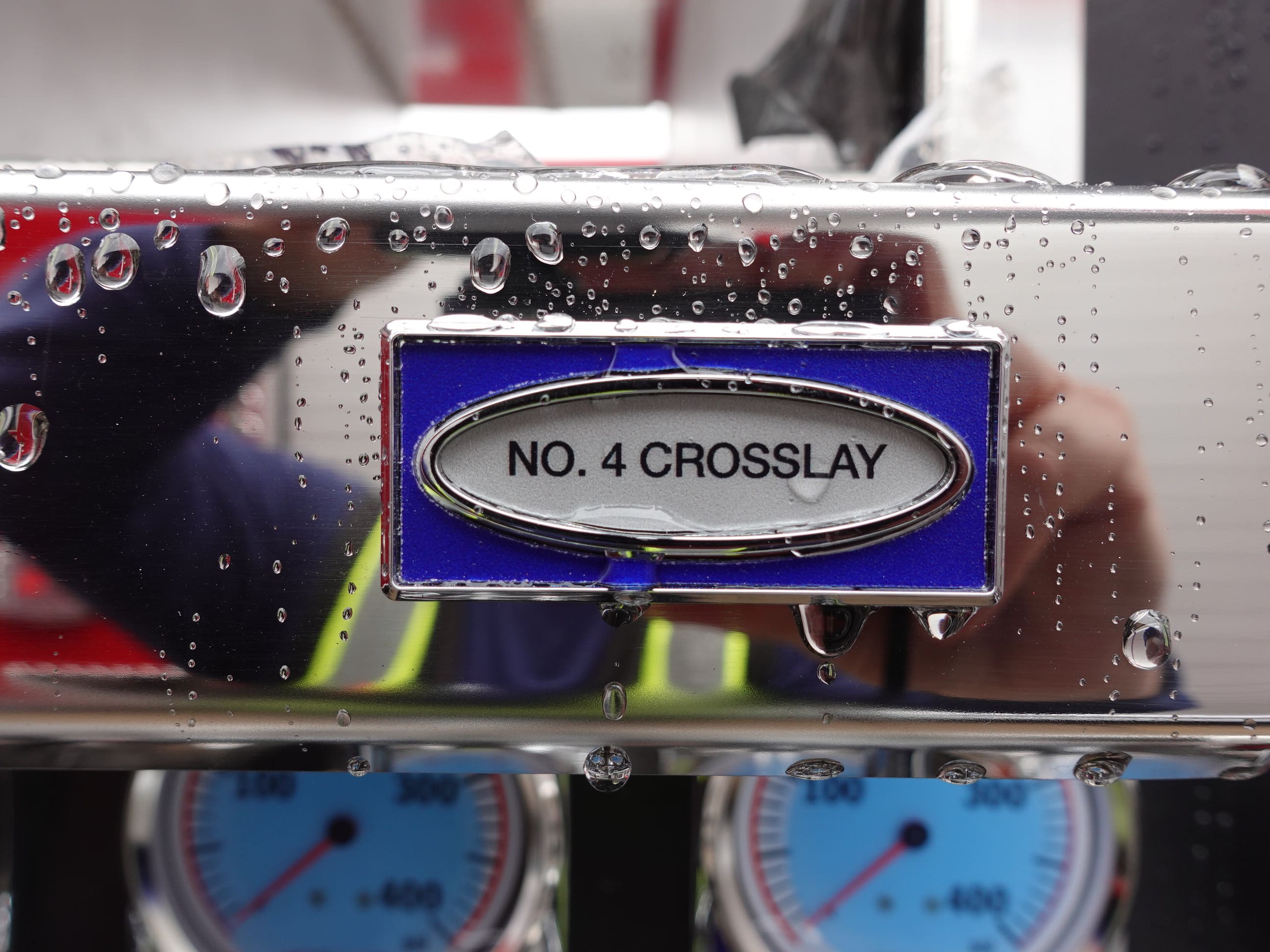

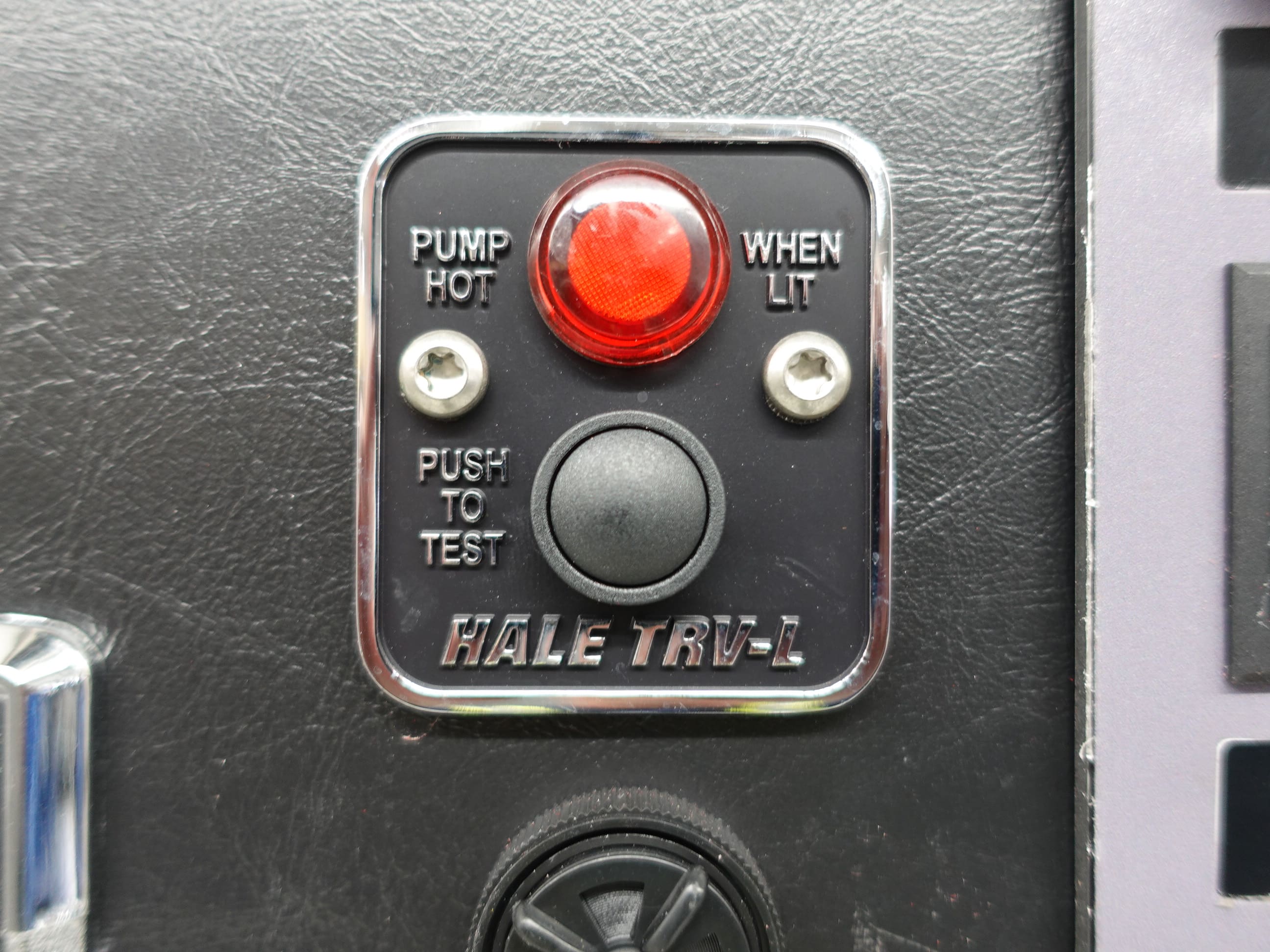

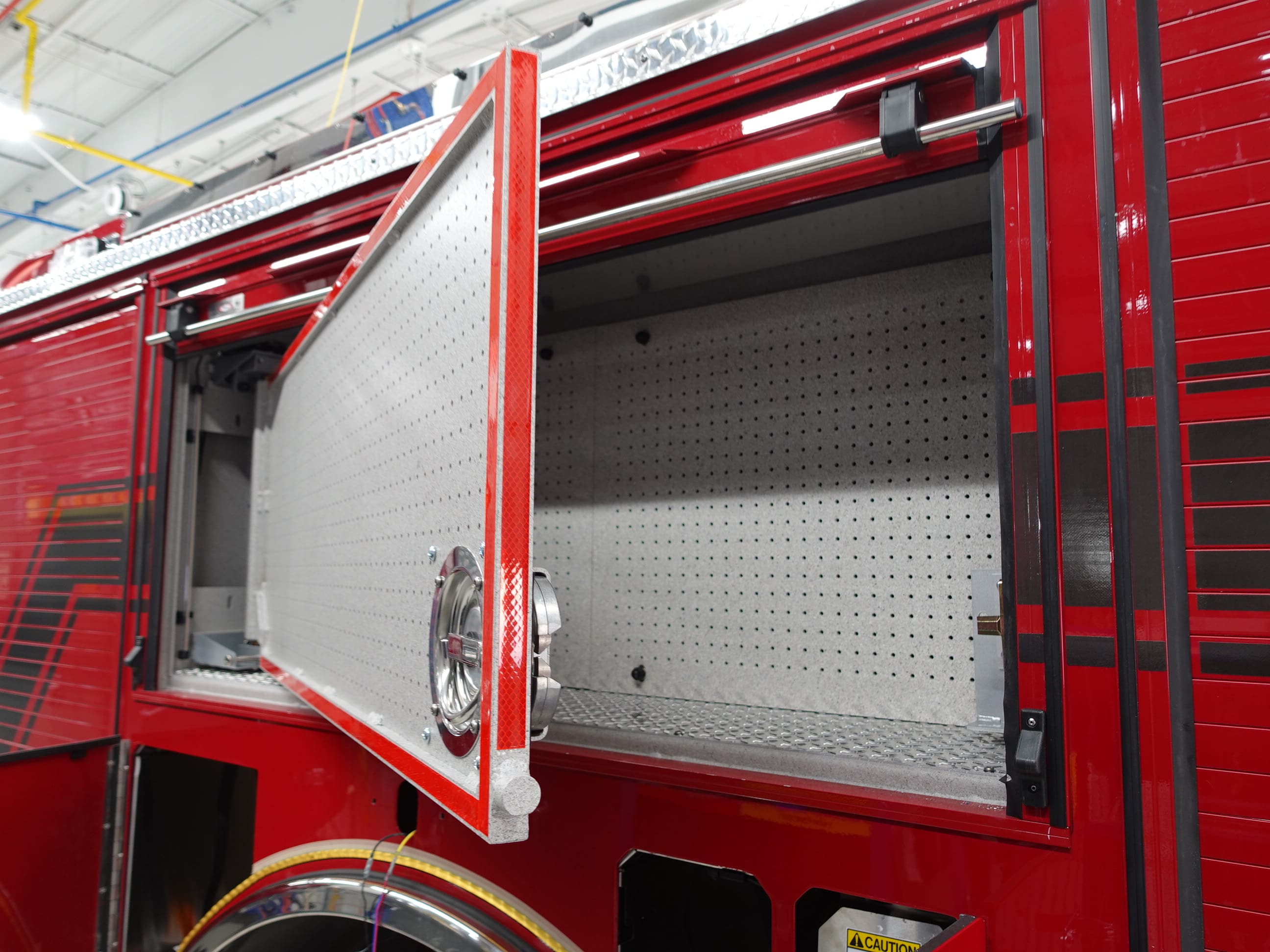

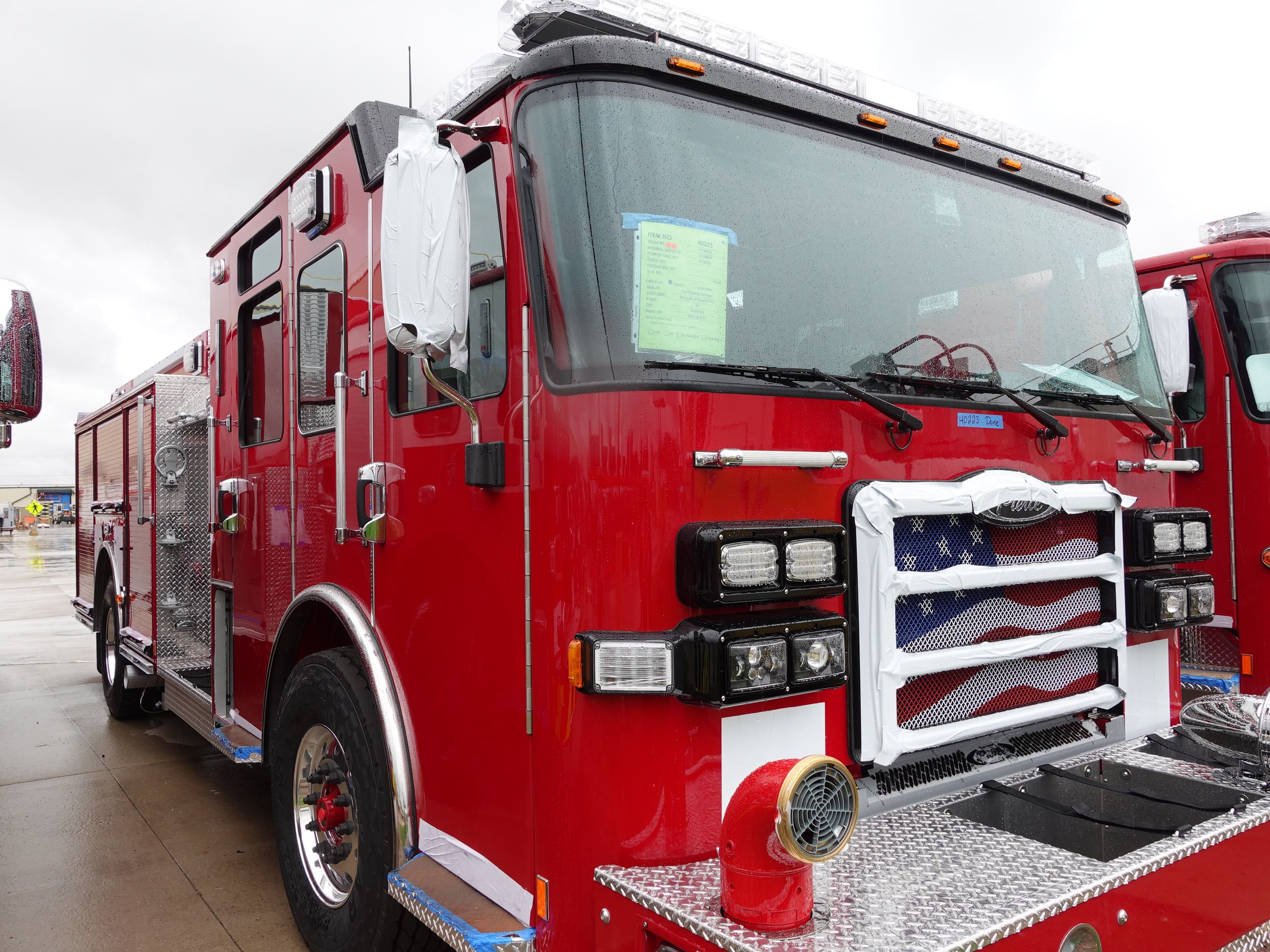

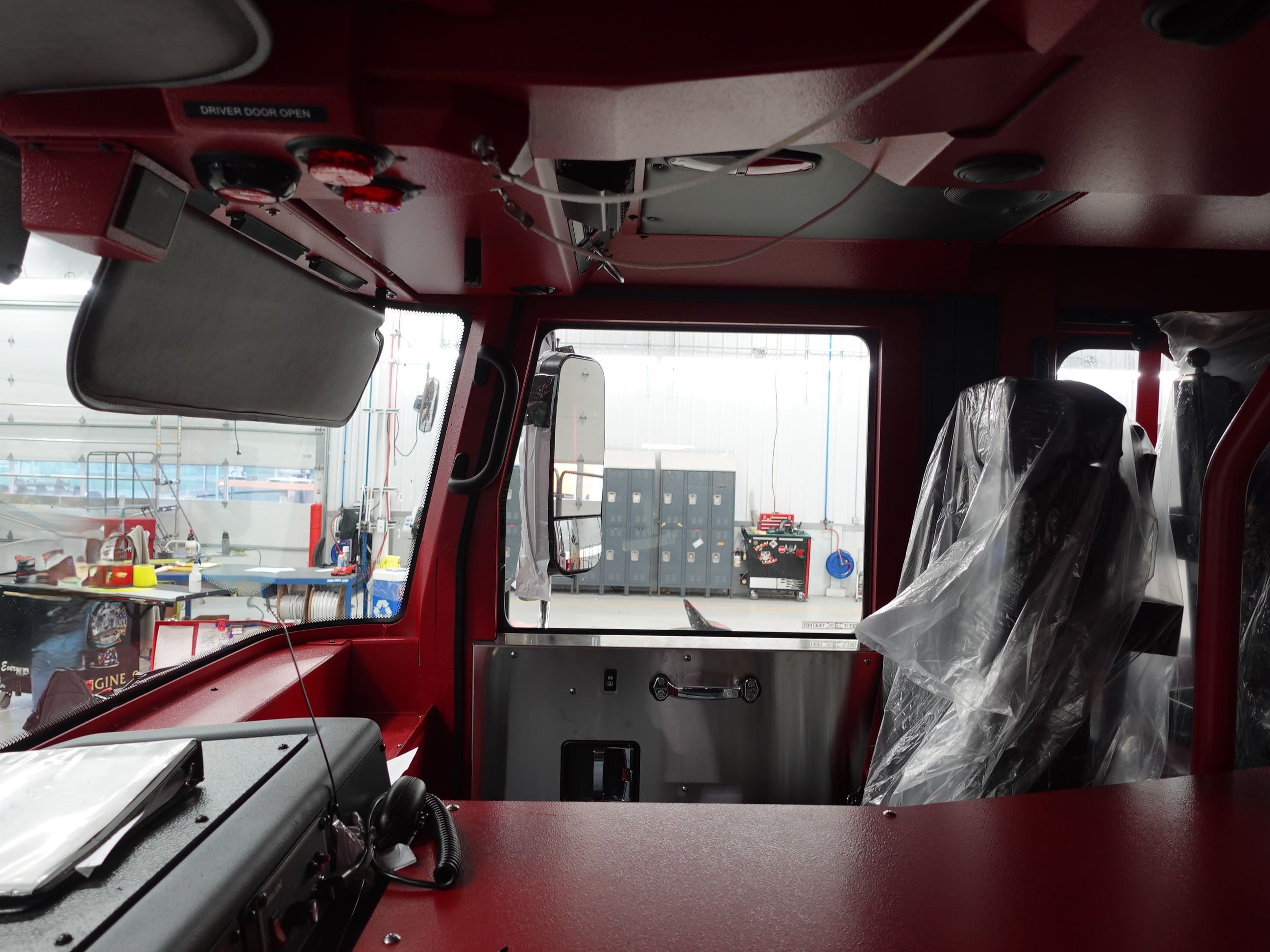

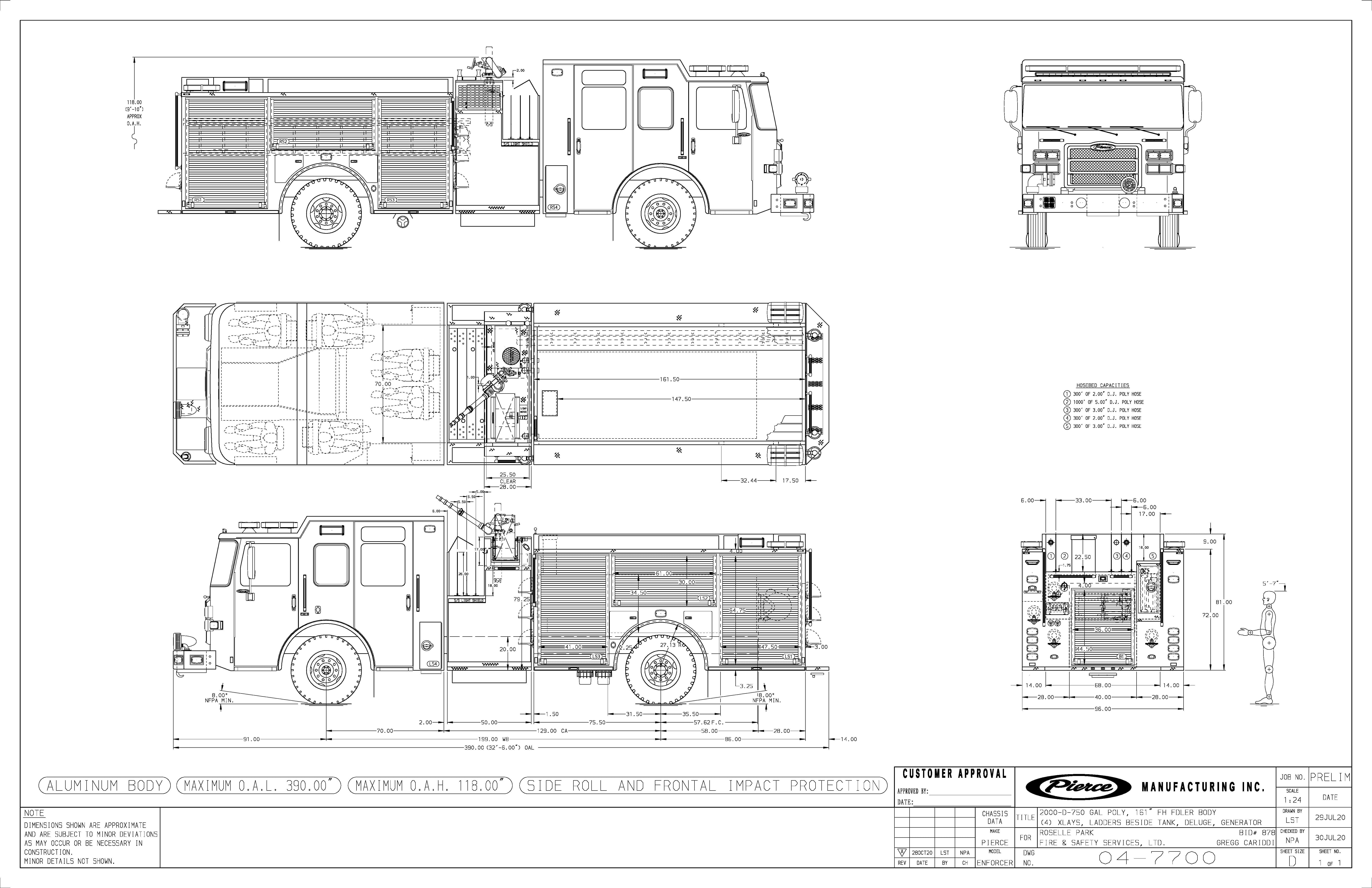

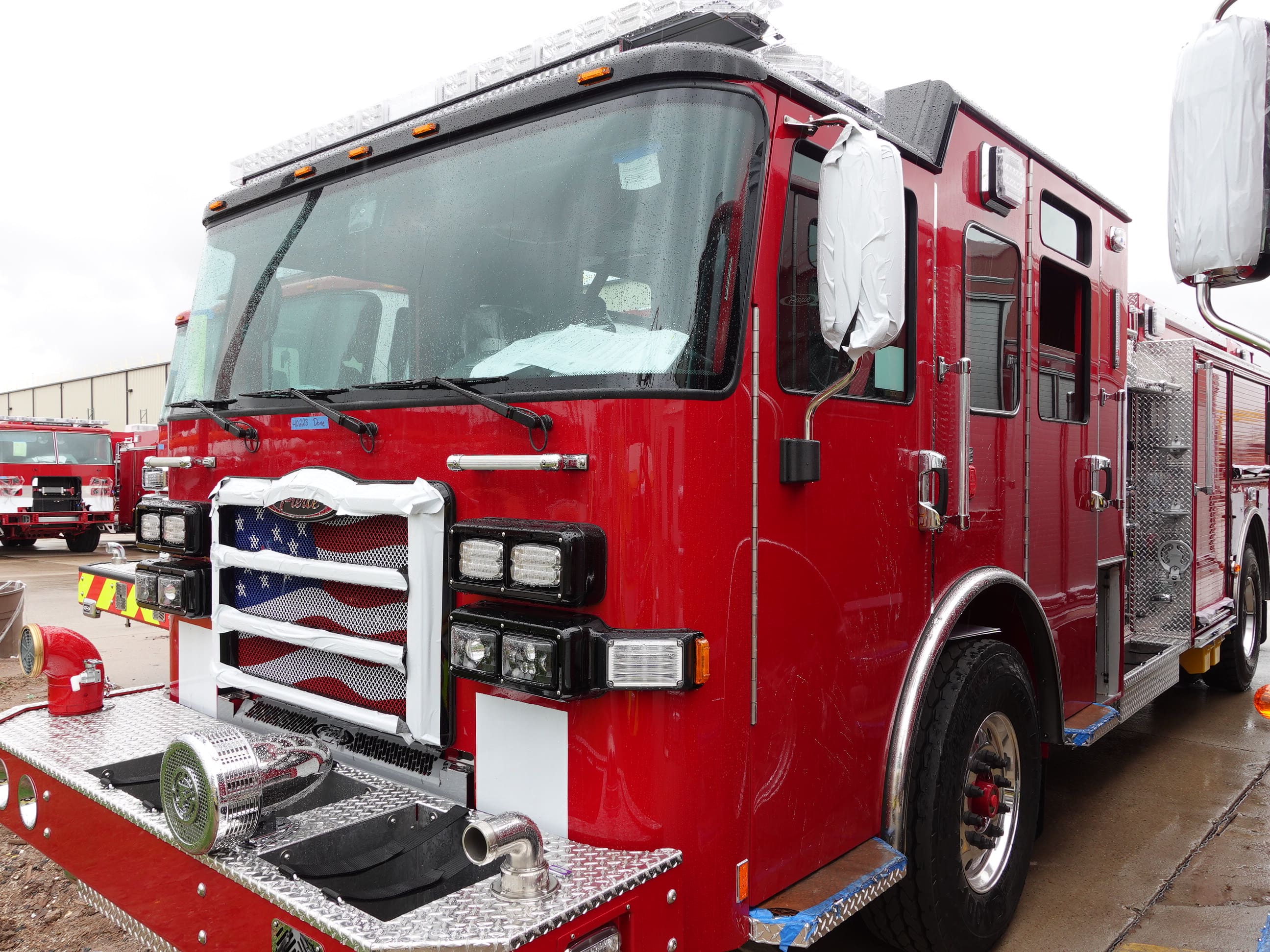

05-15-26

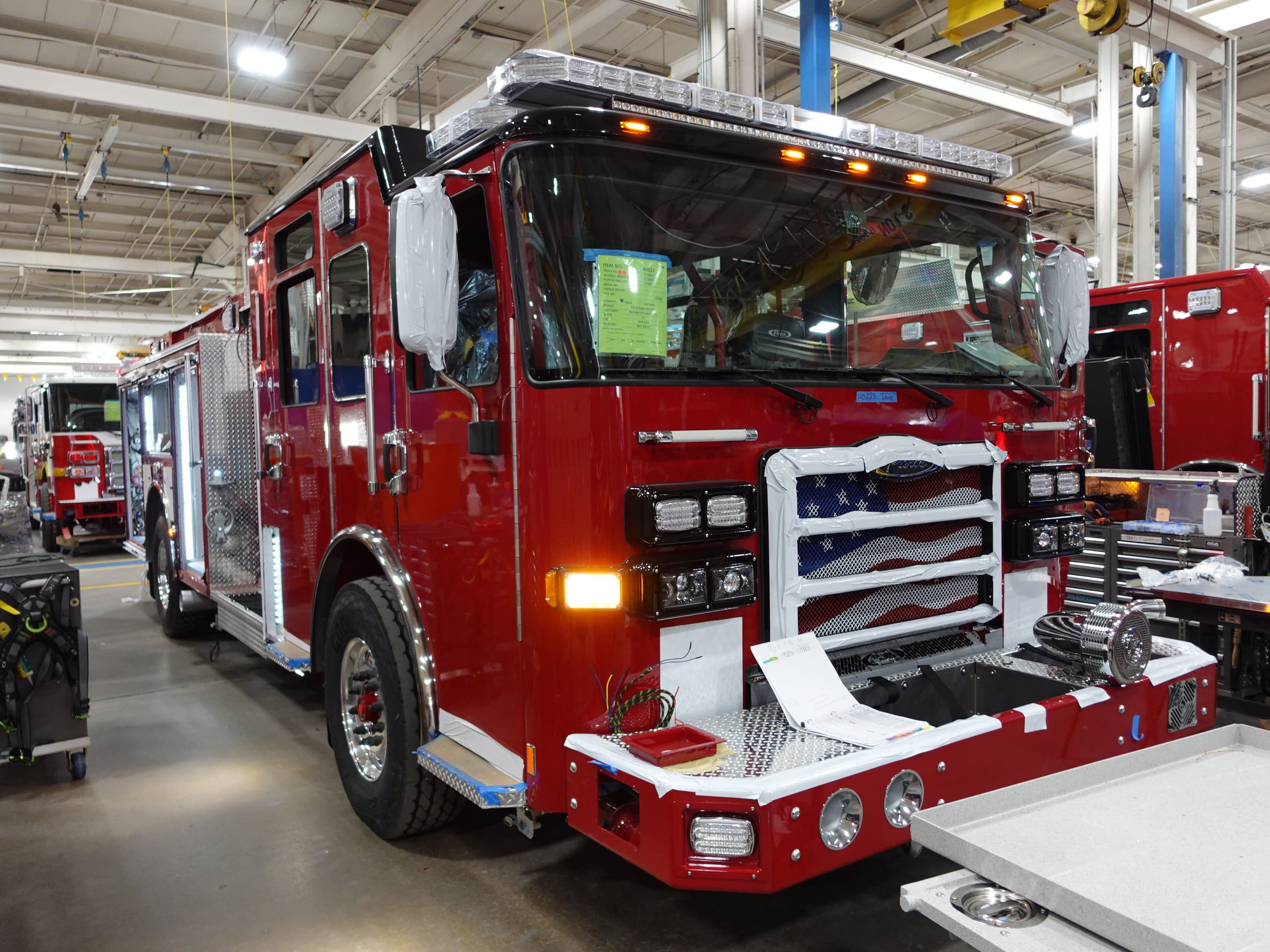

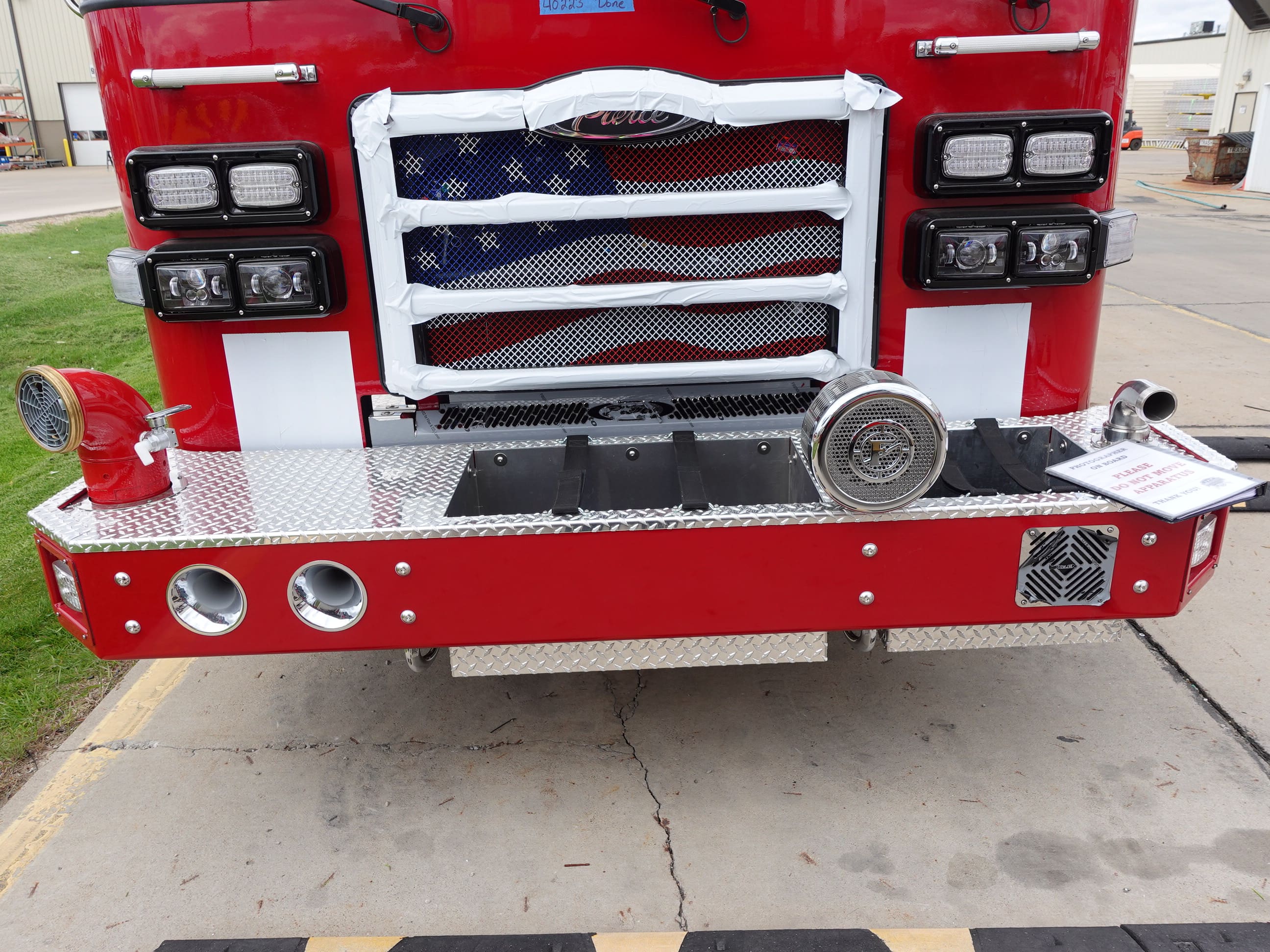

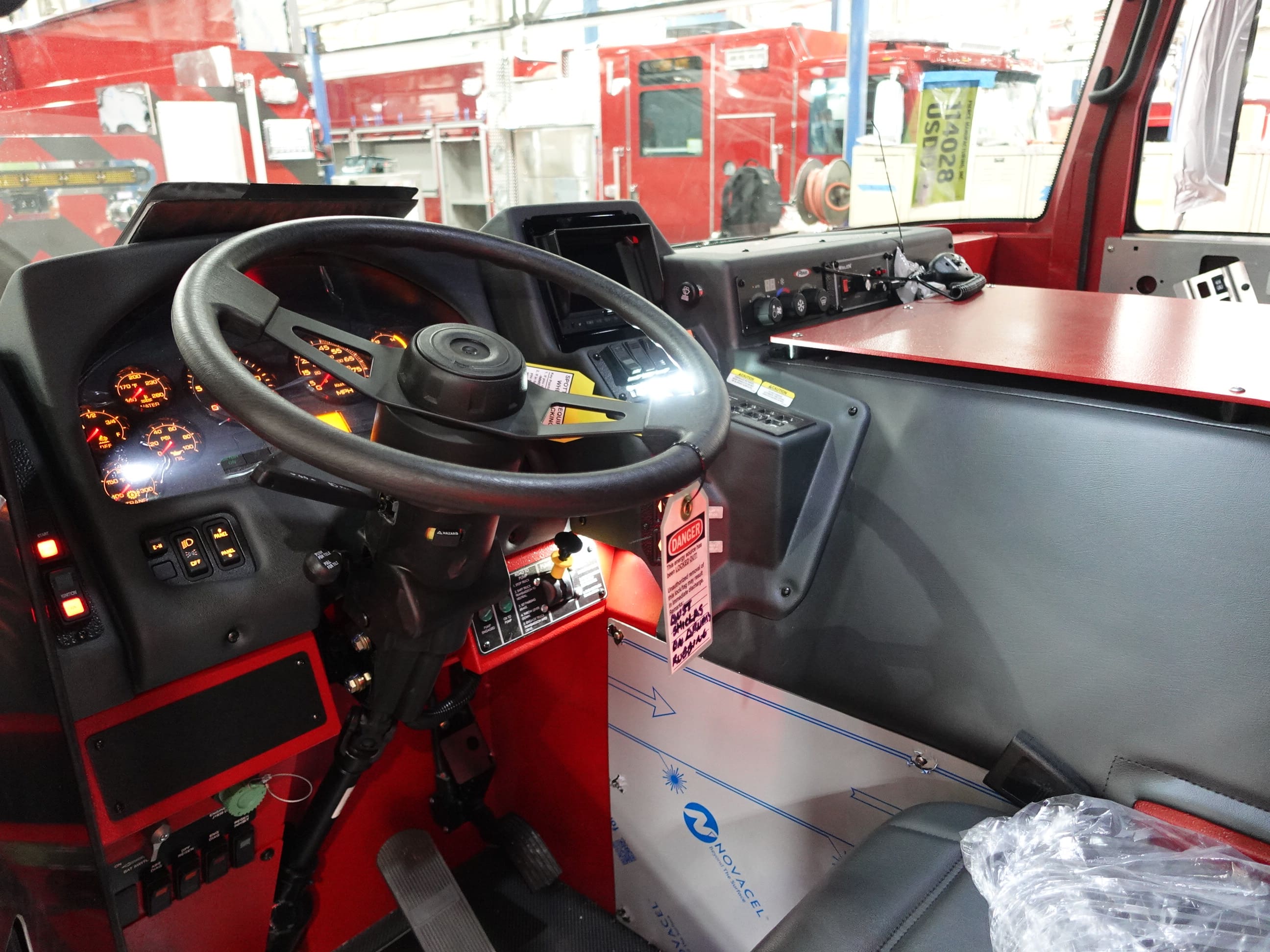

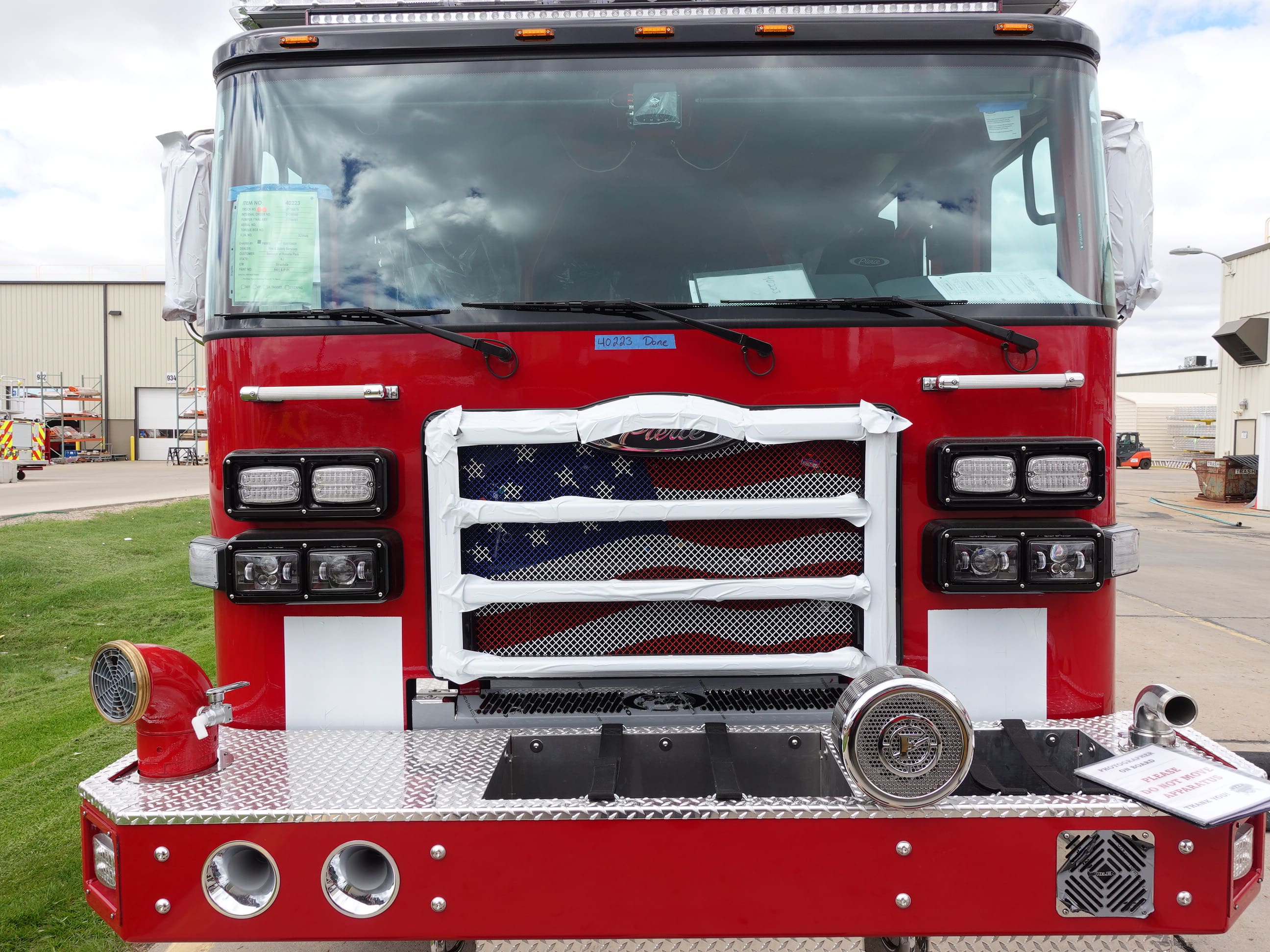

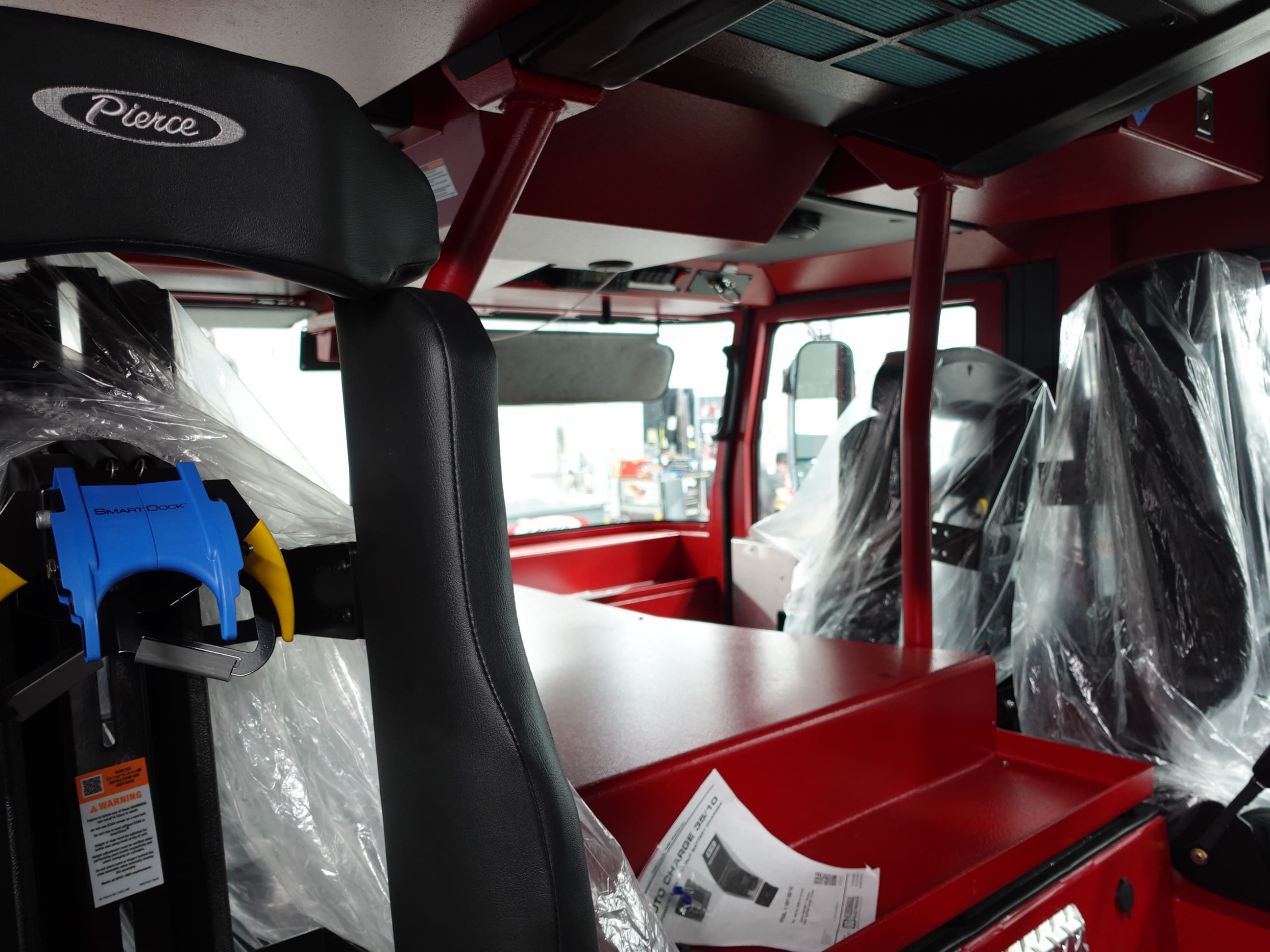

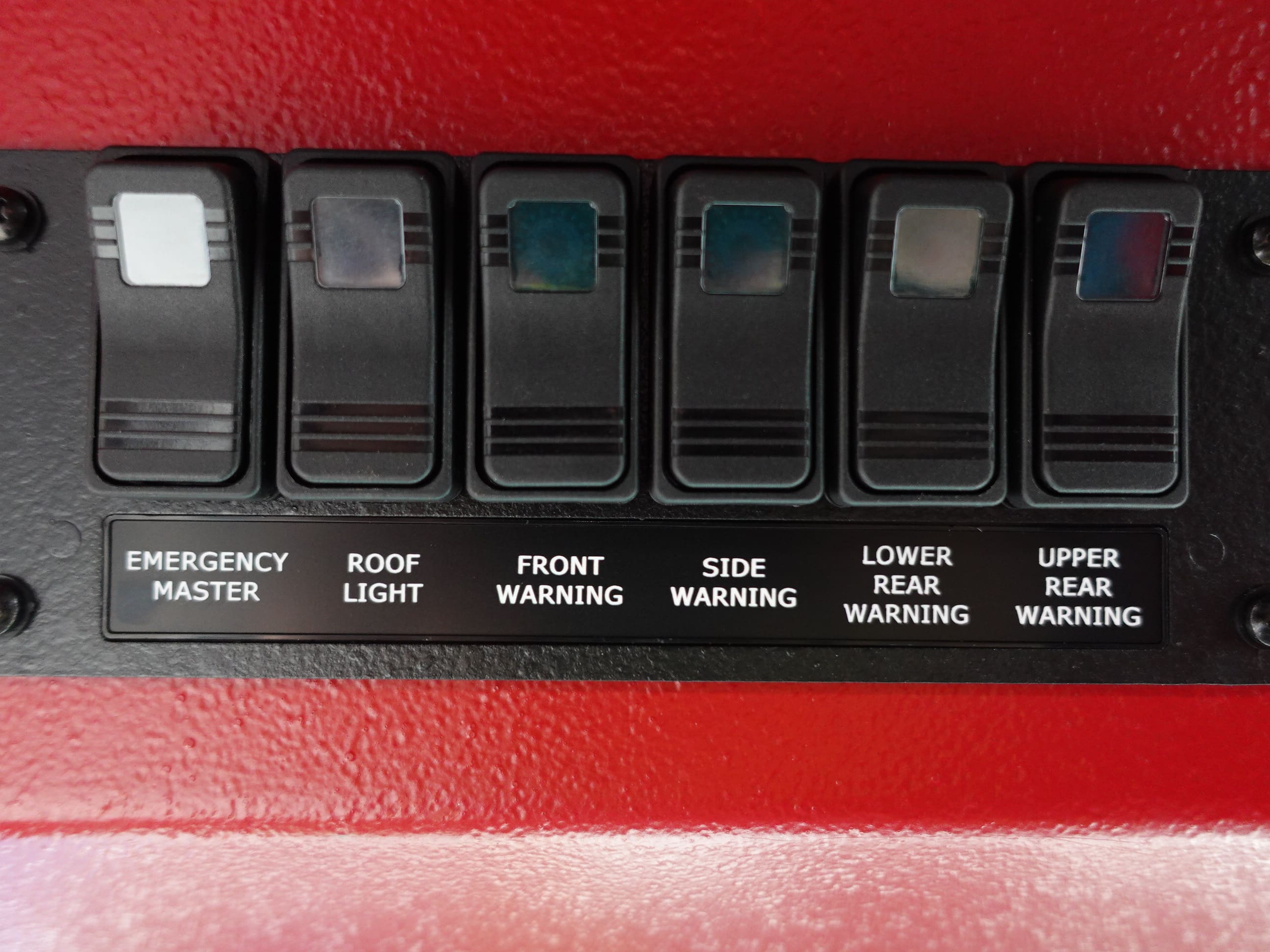

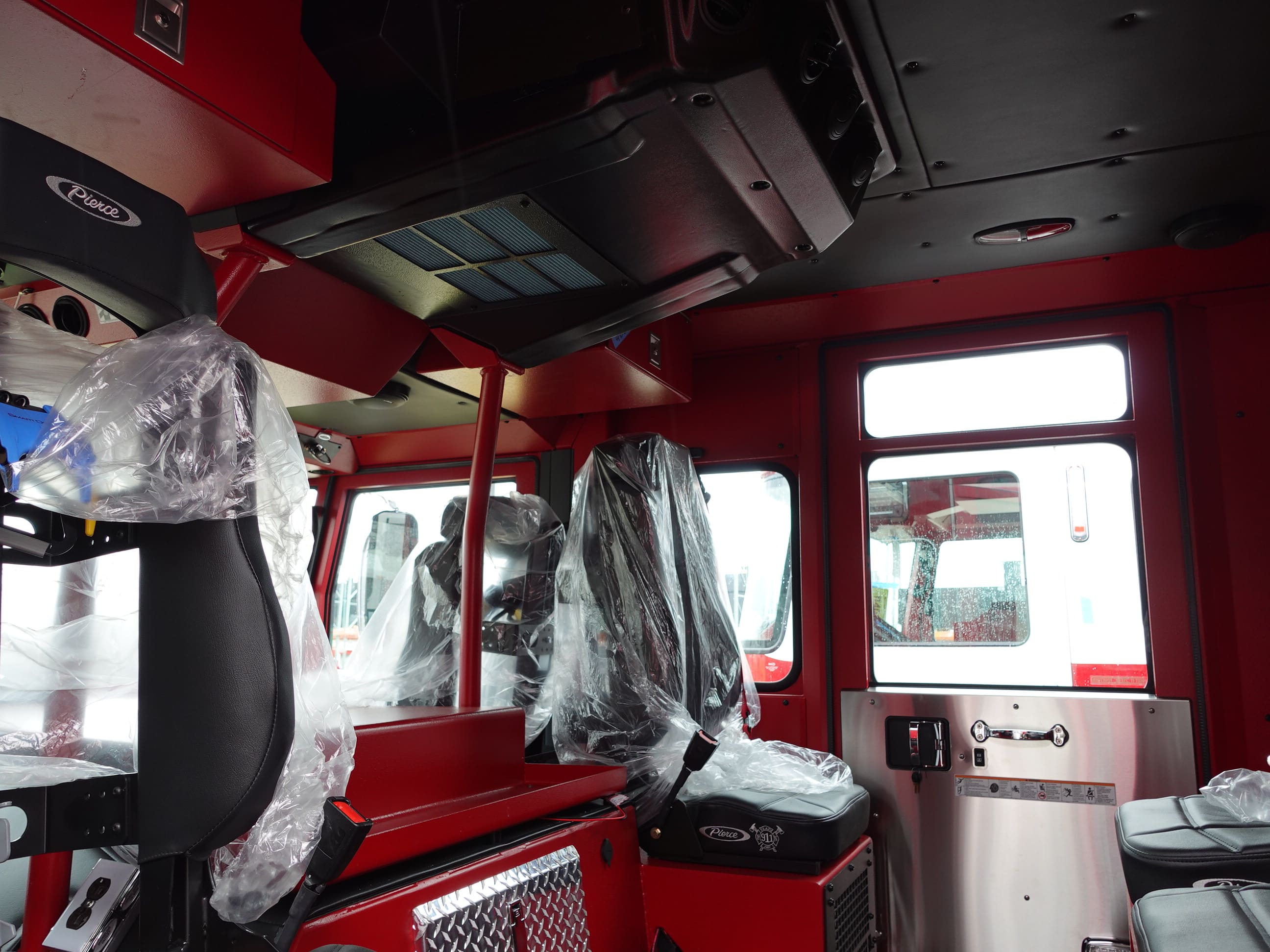

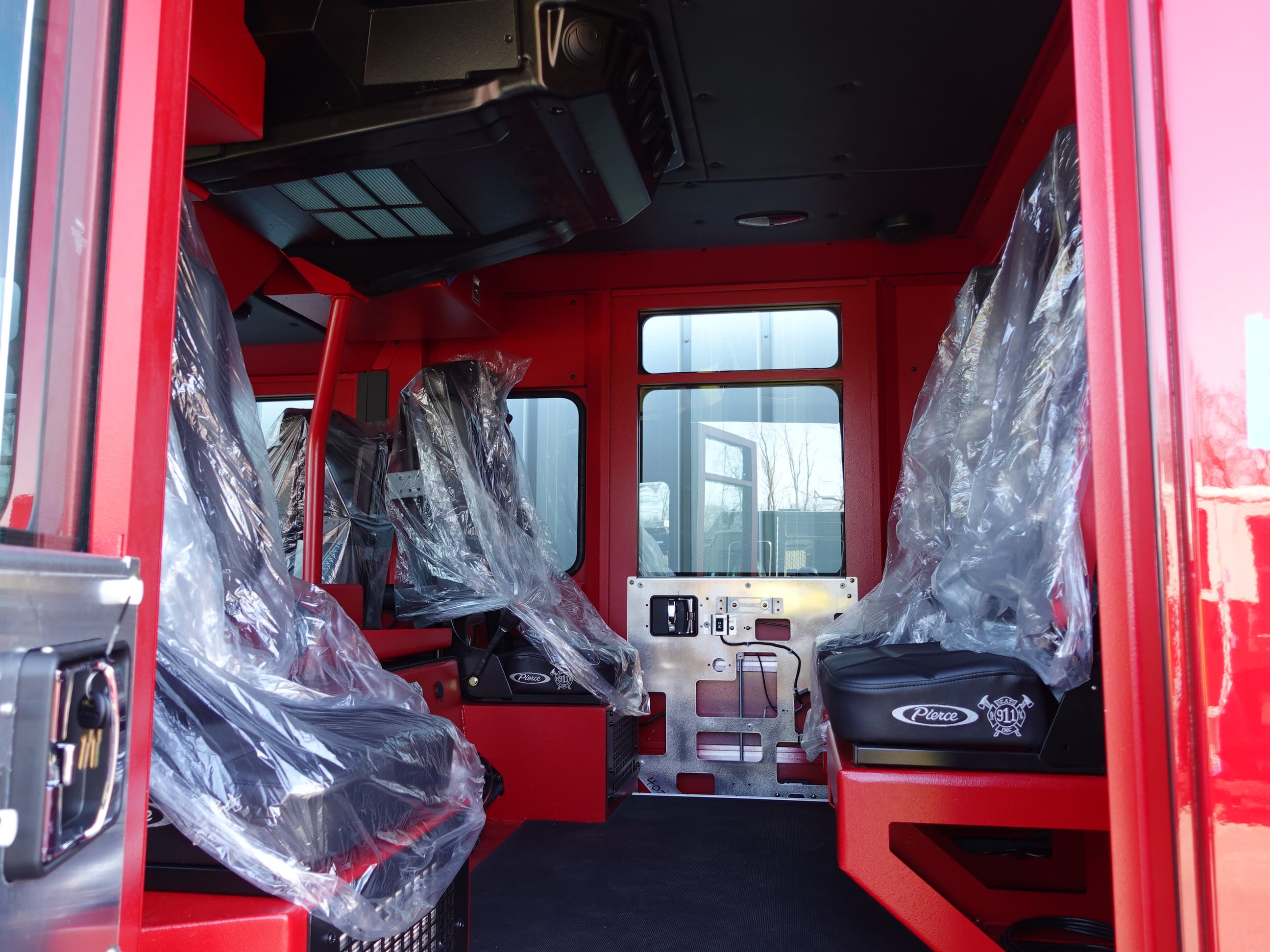

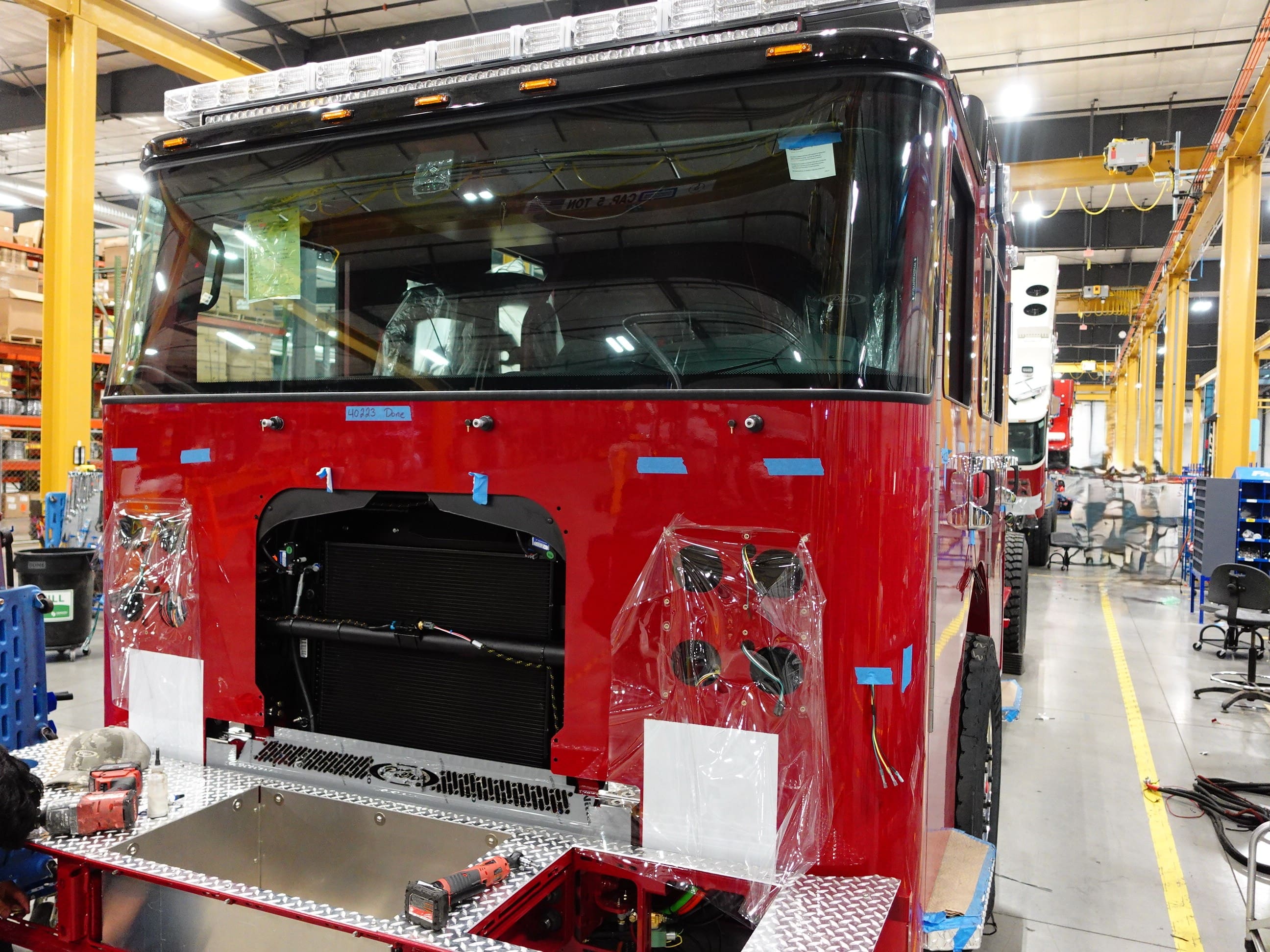

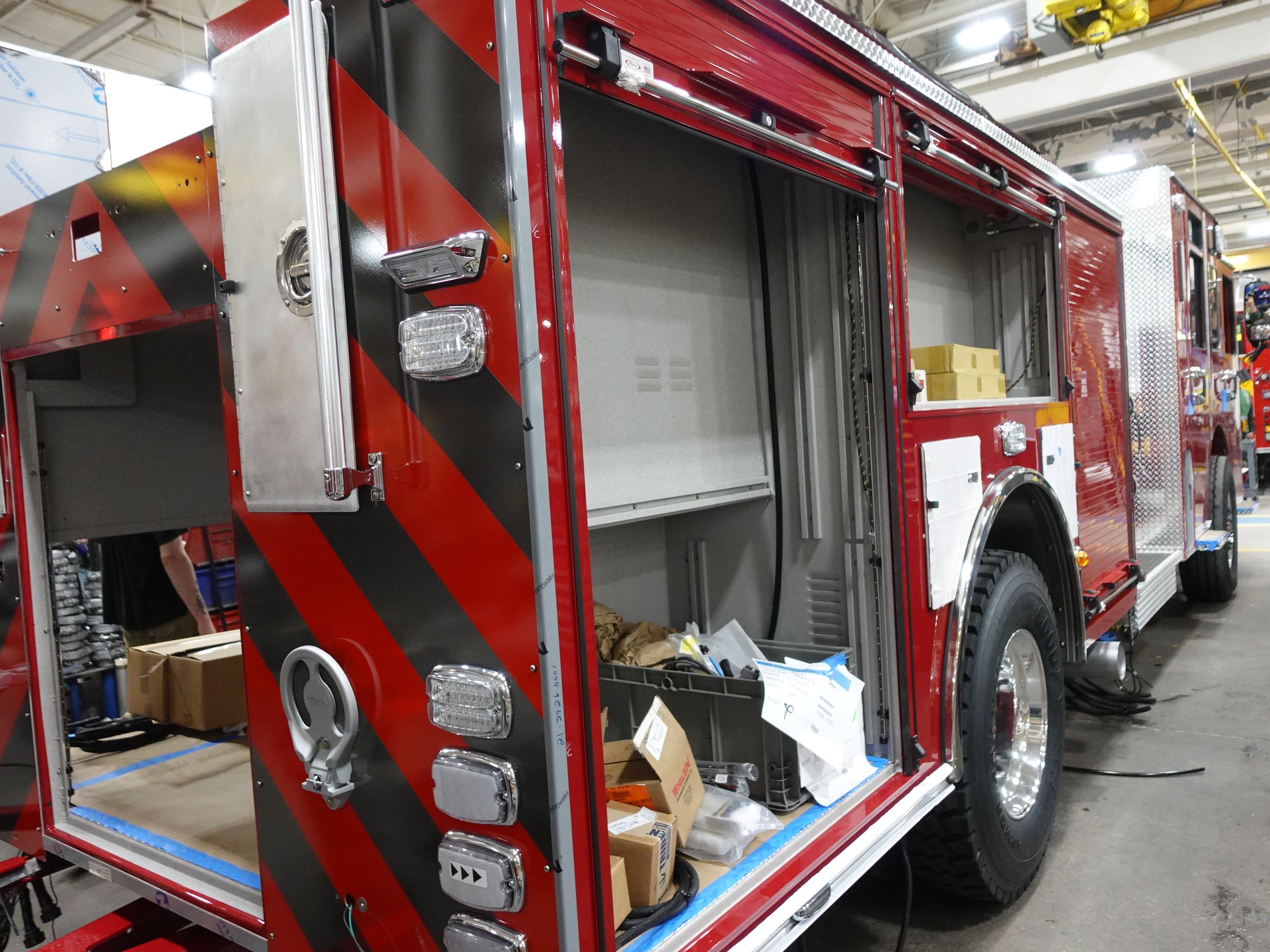

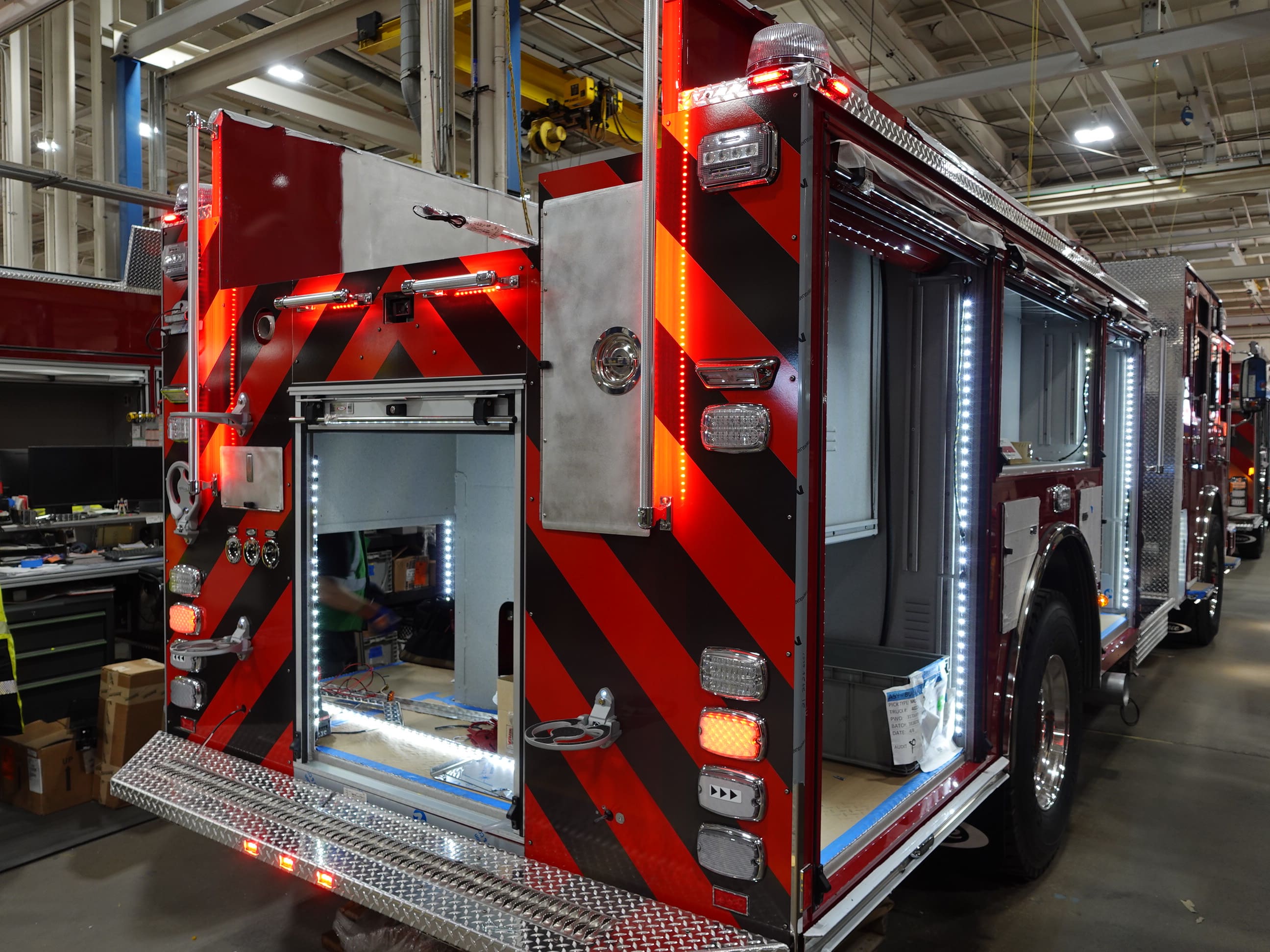

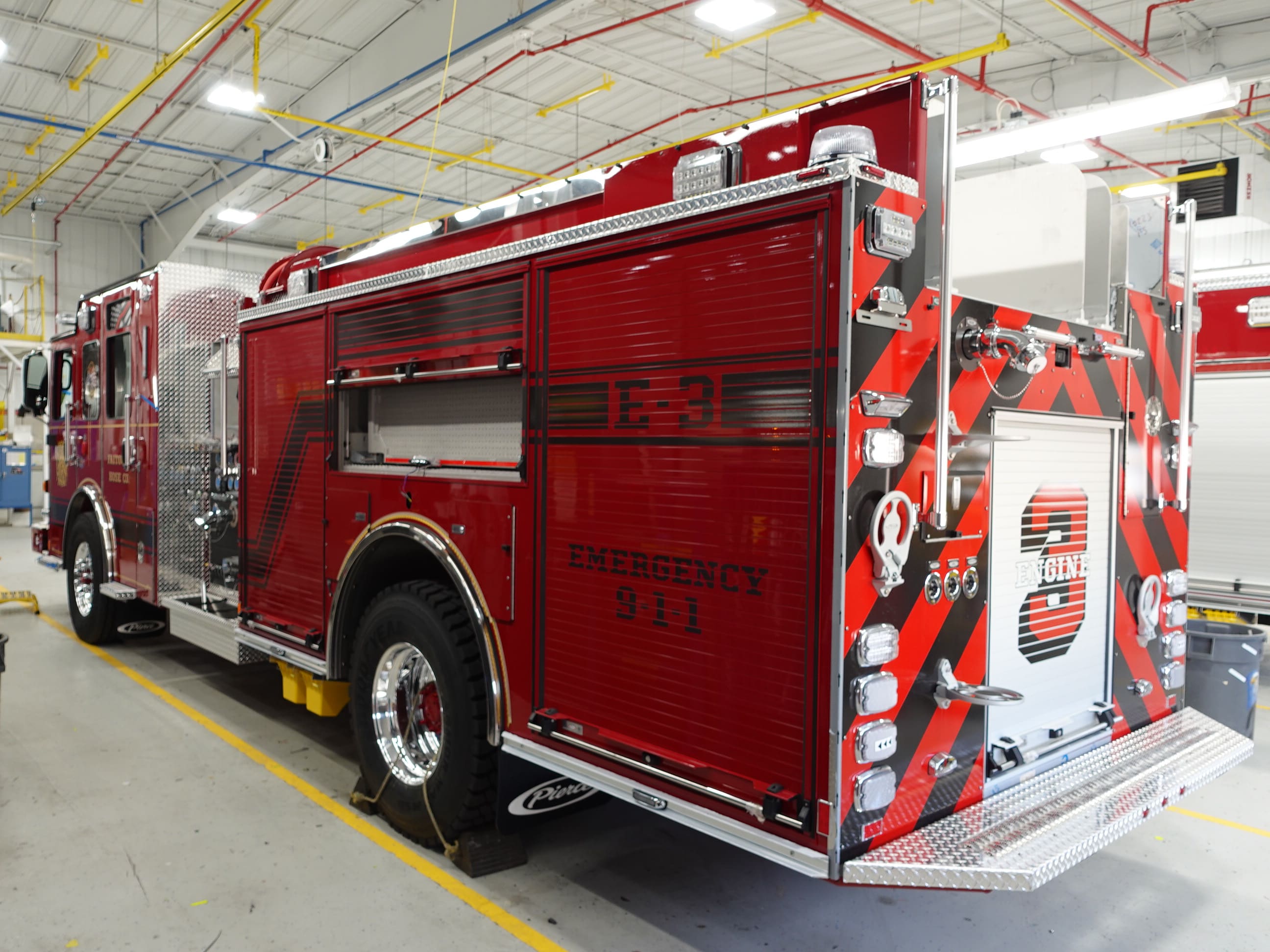

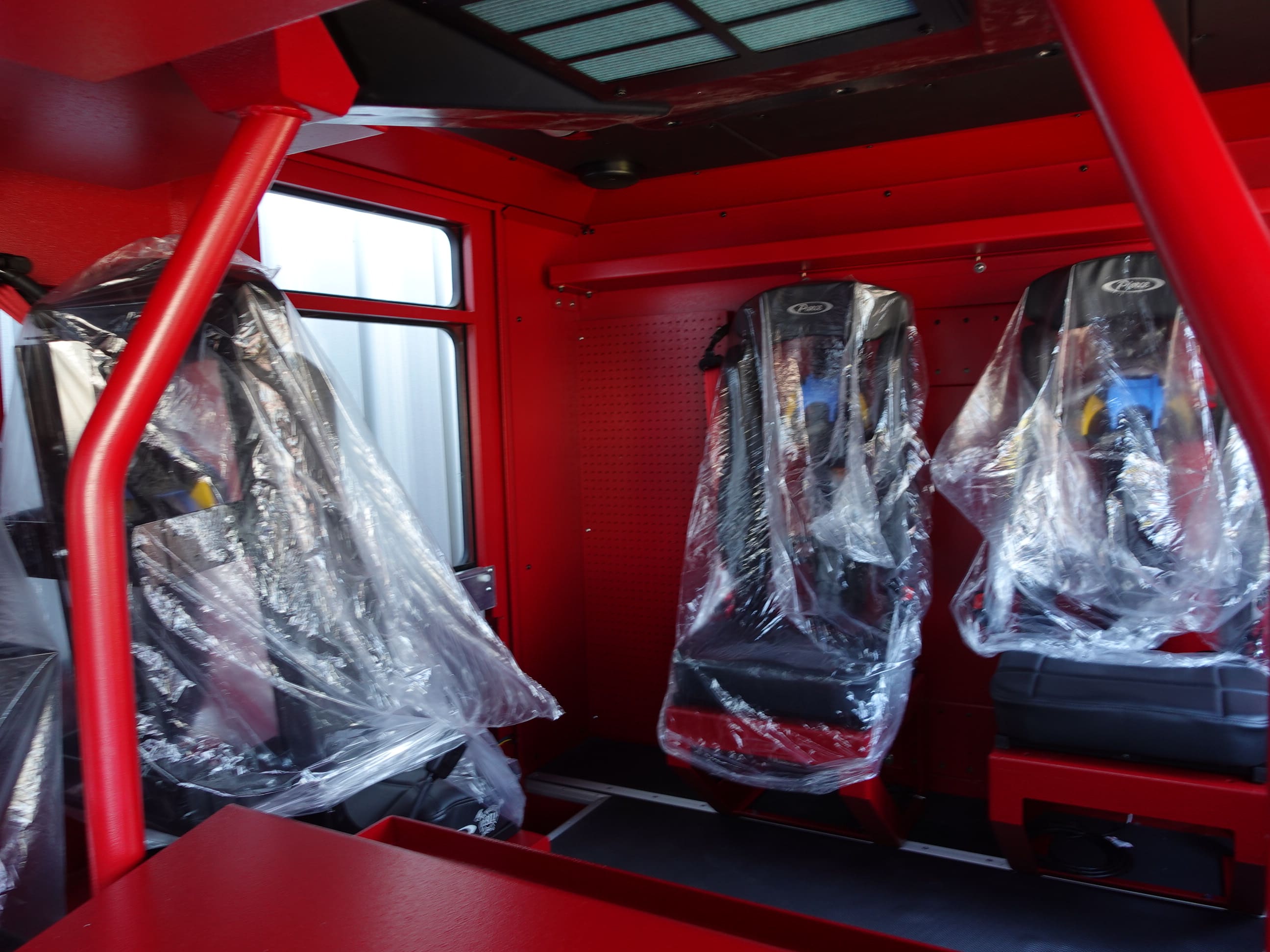

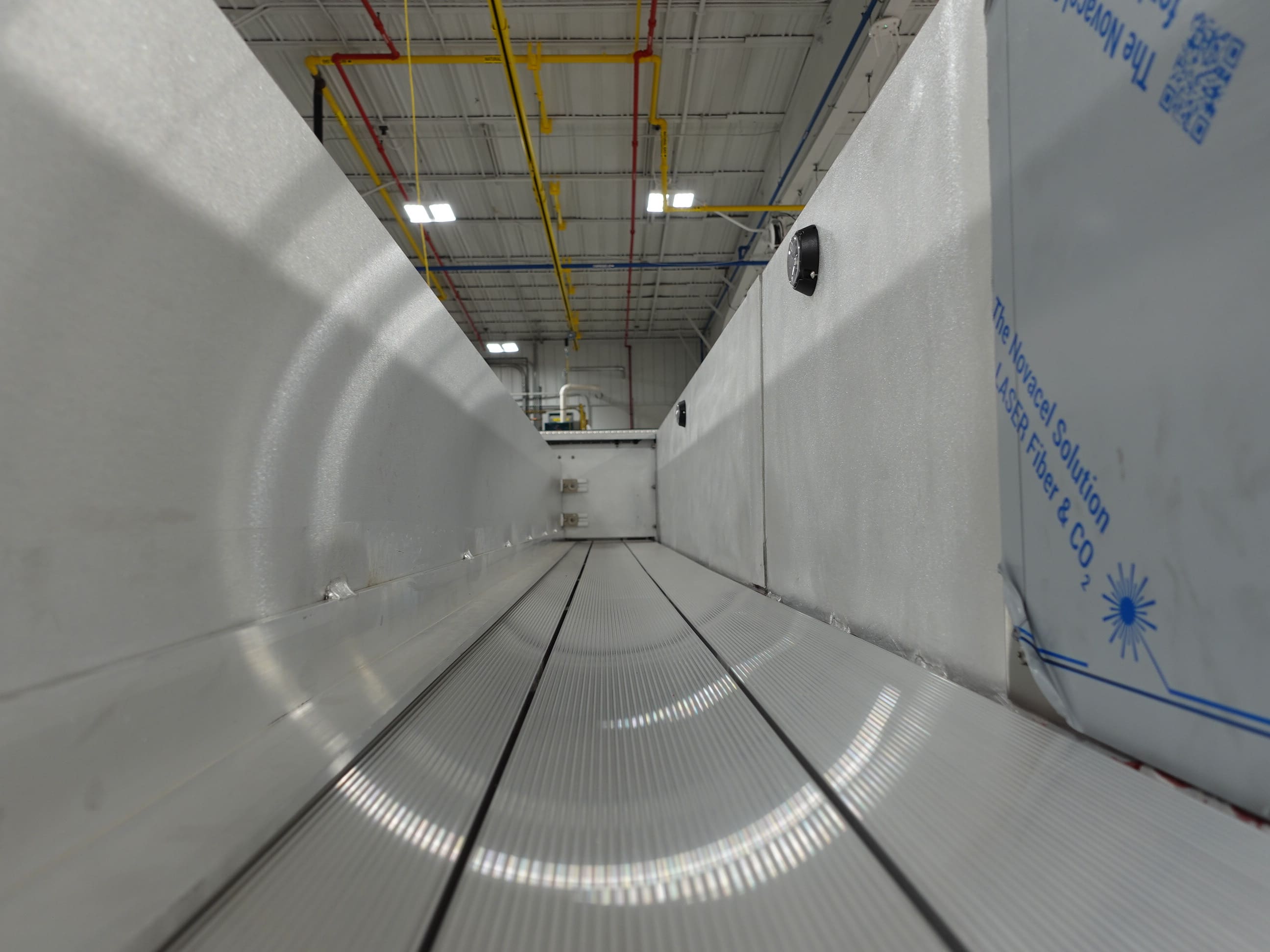

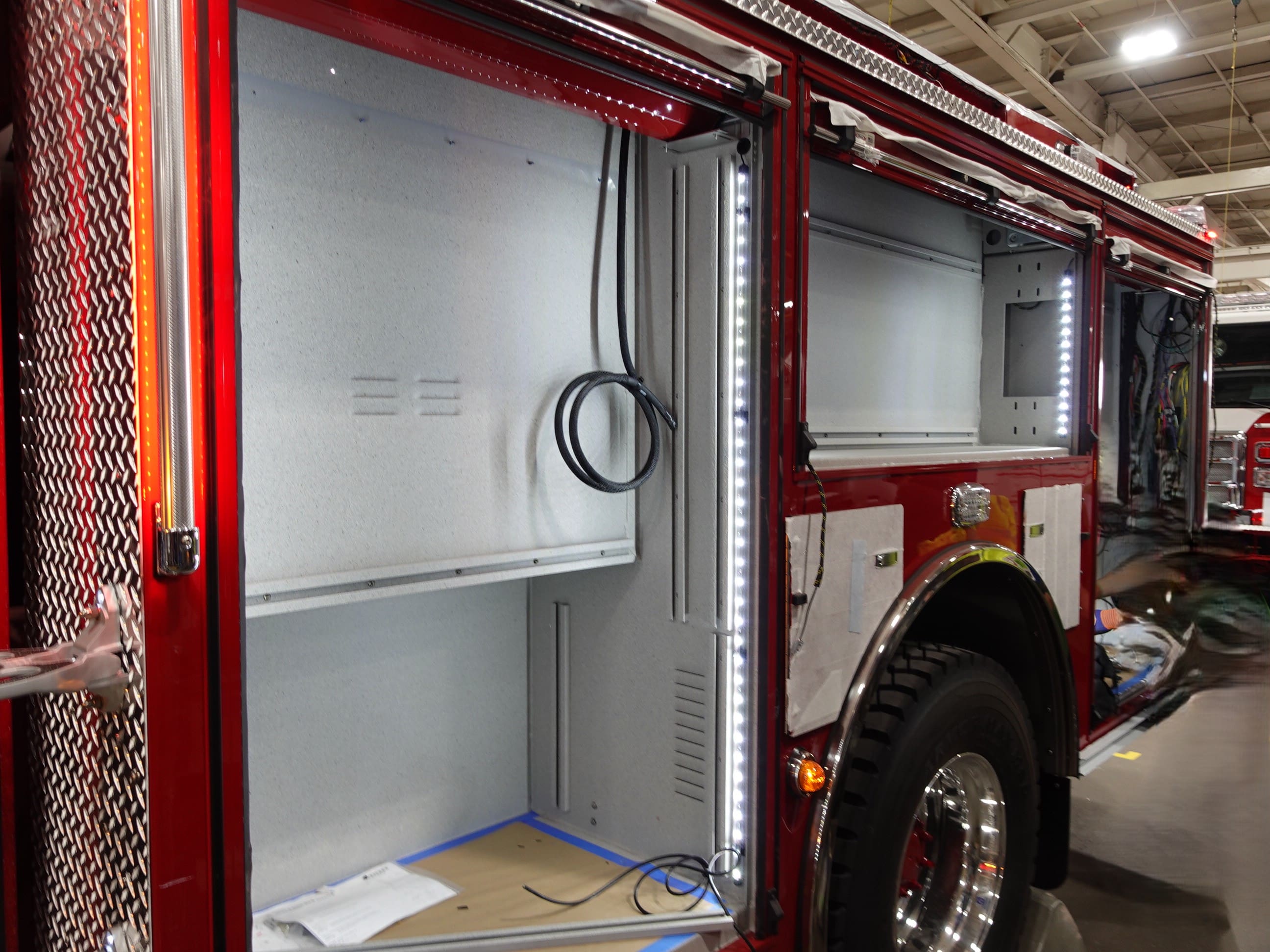

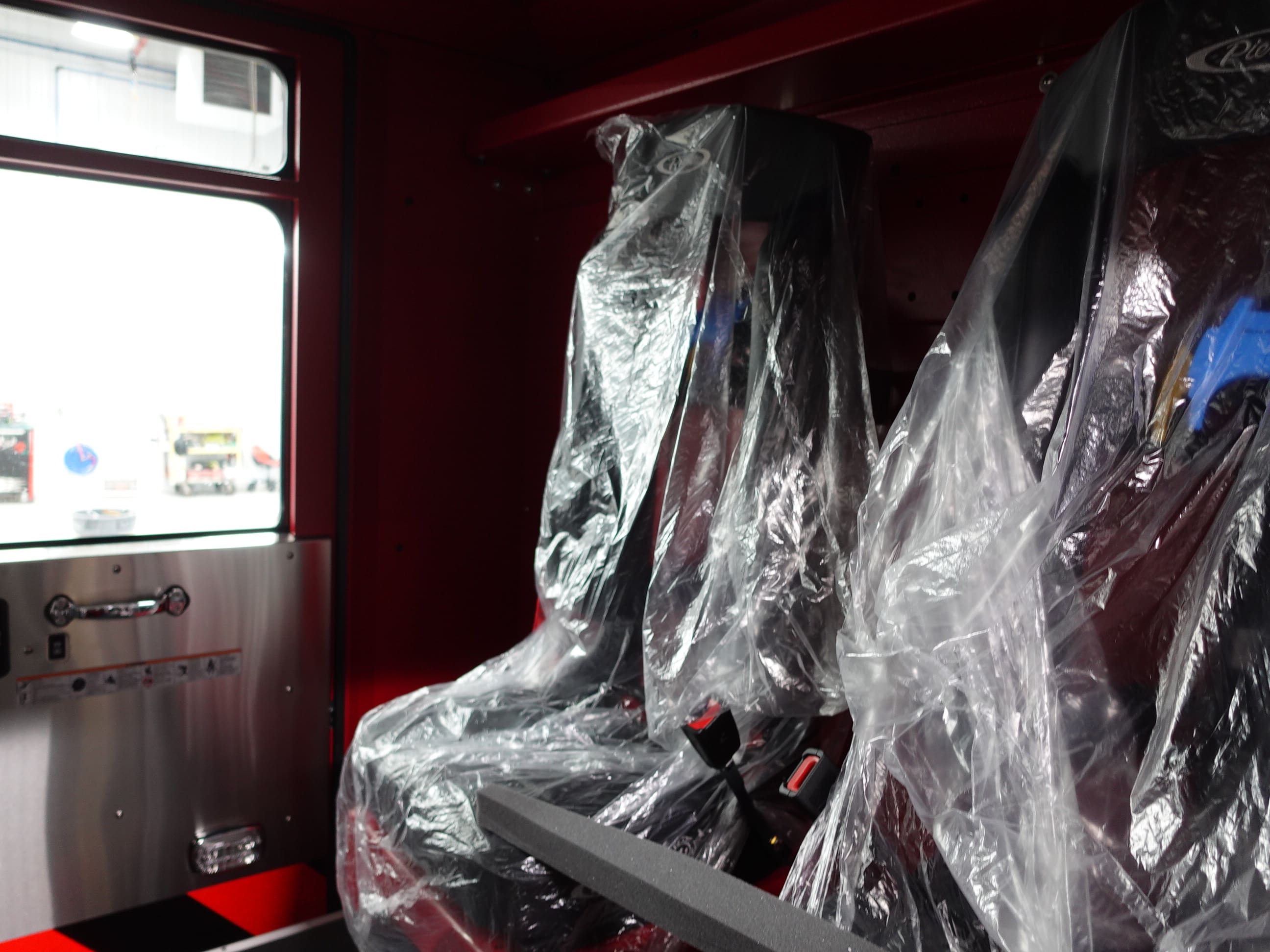

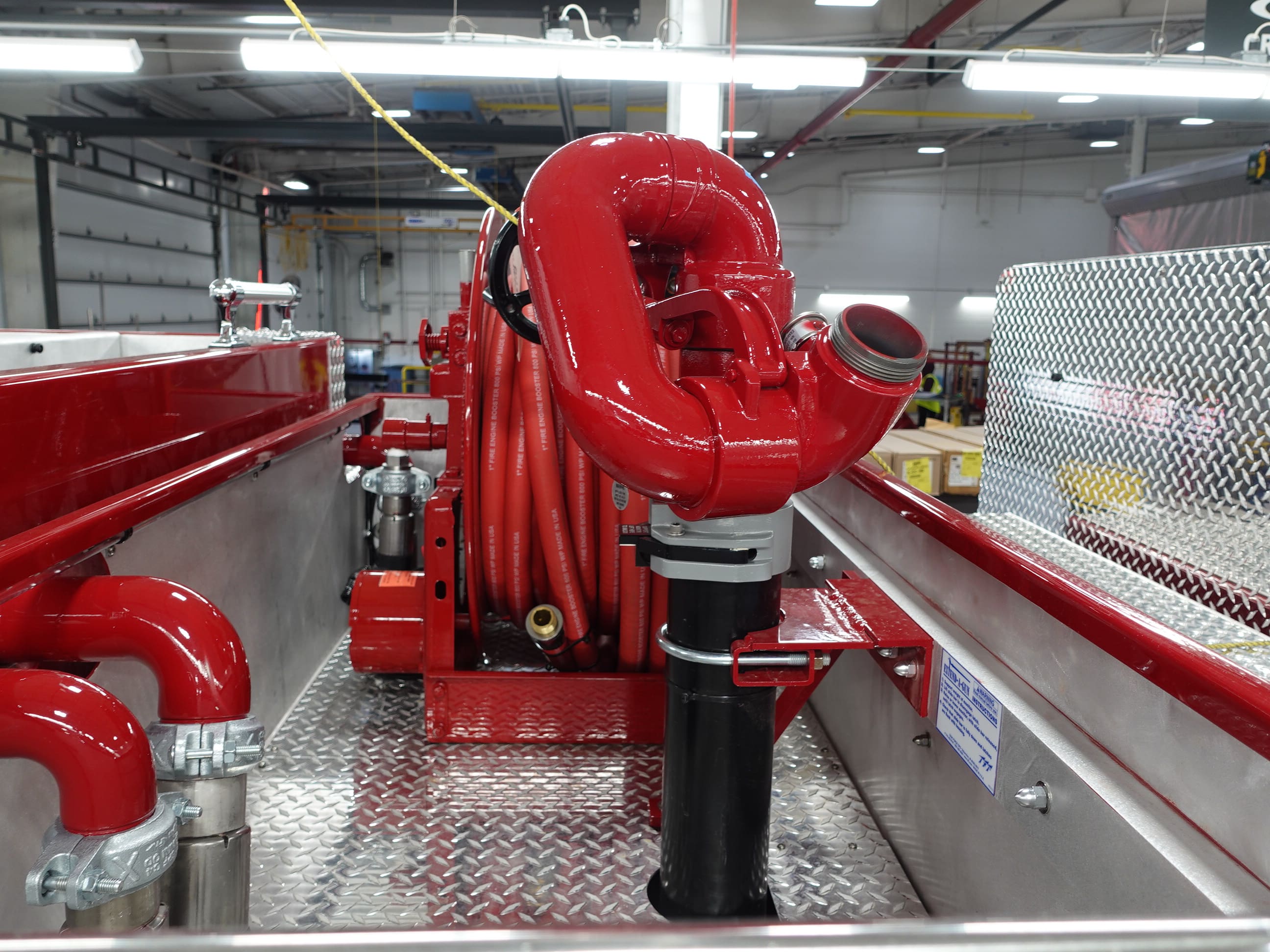

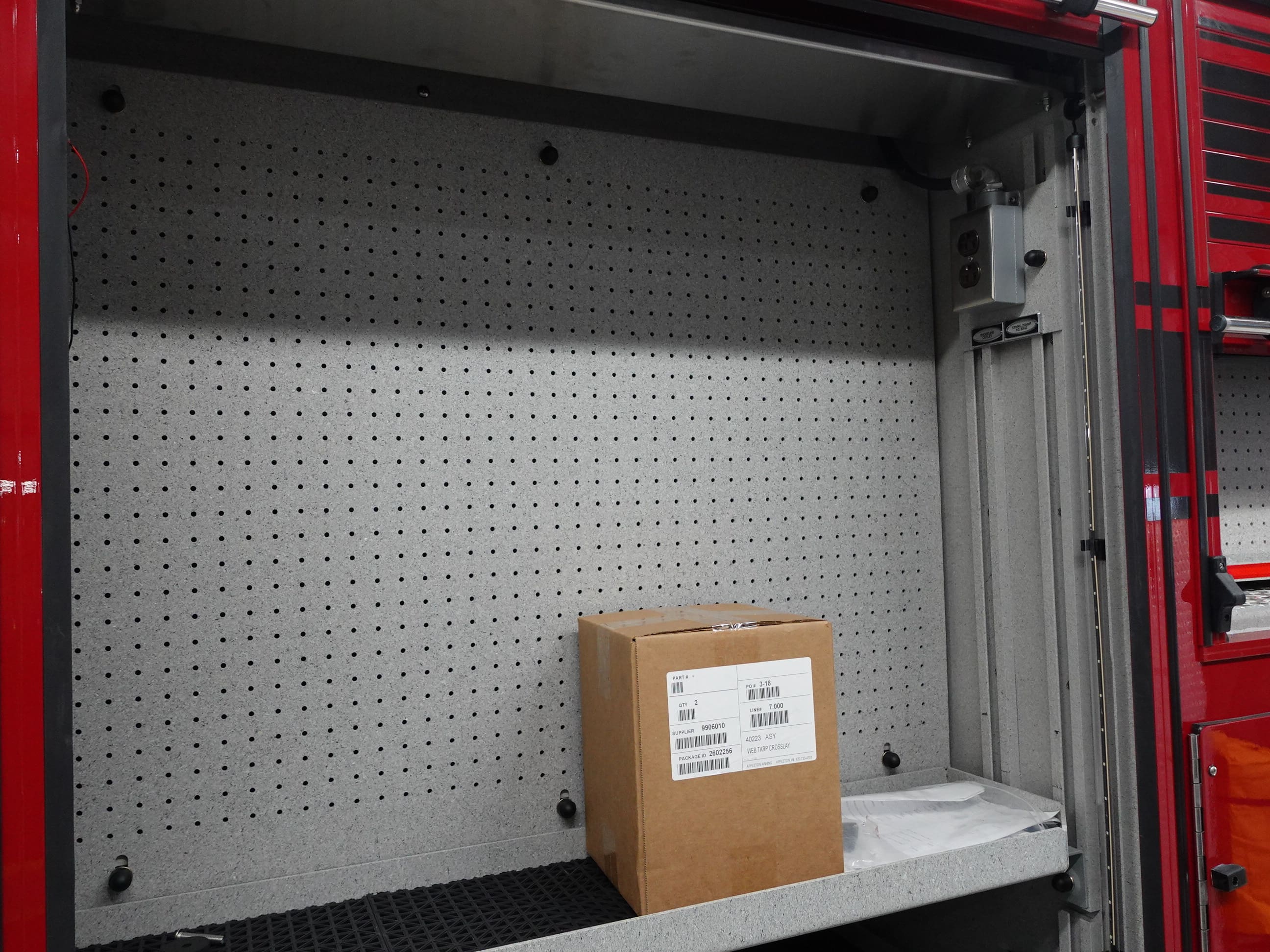

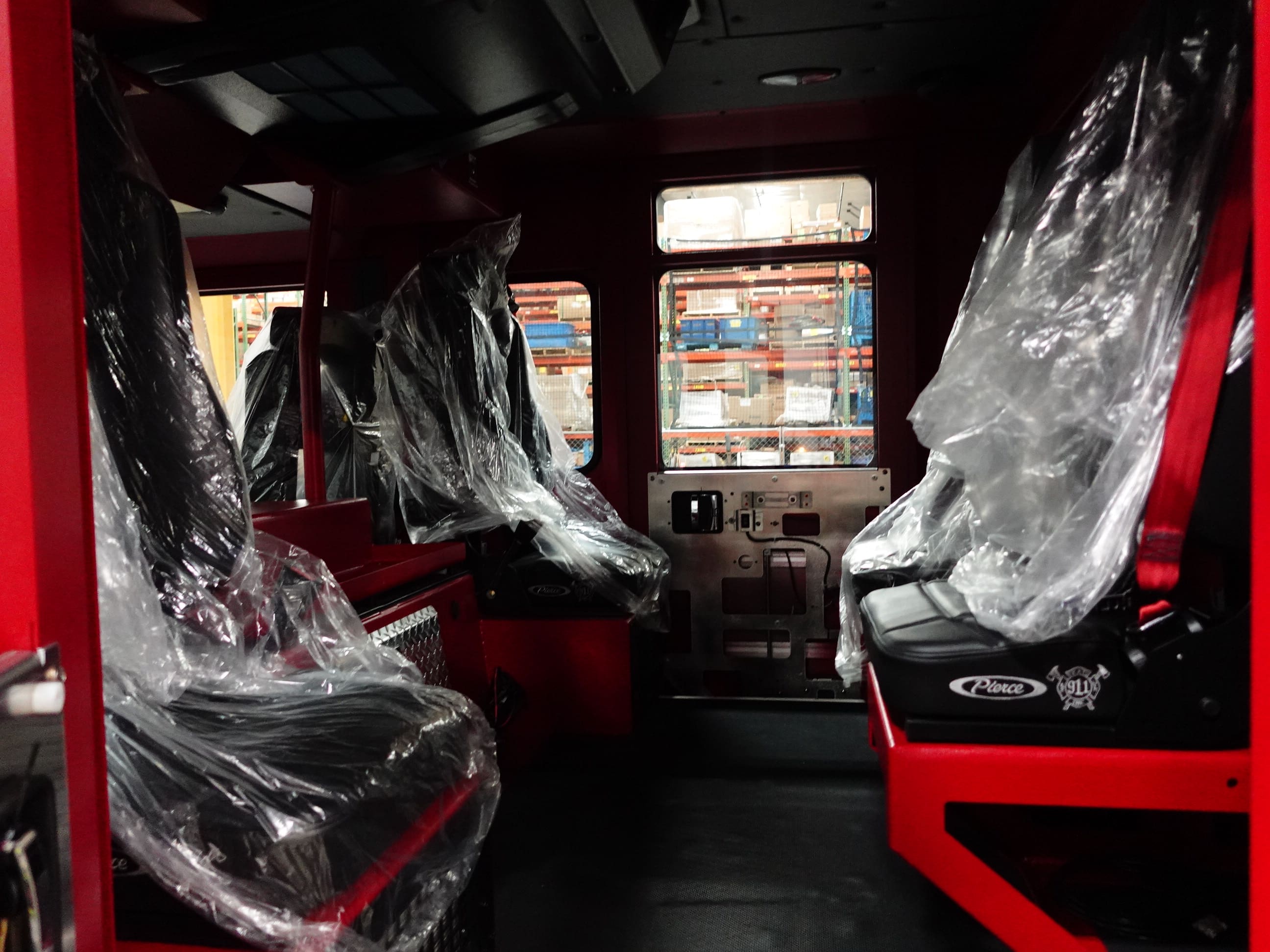

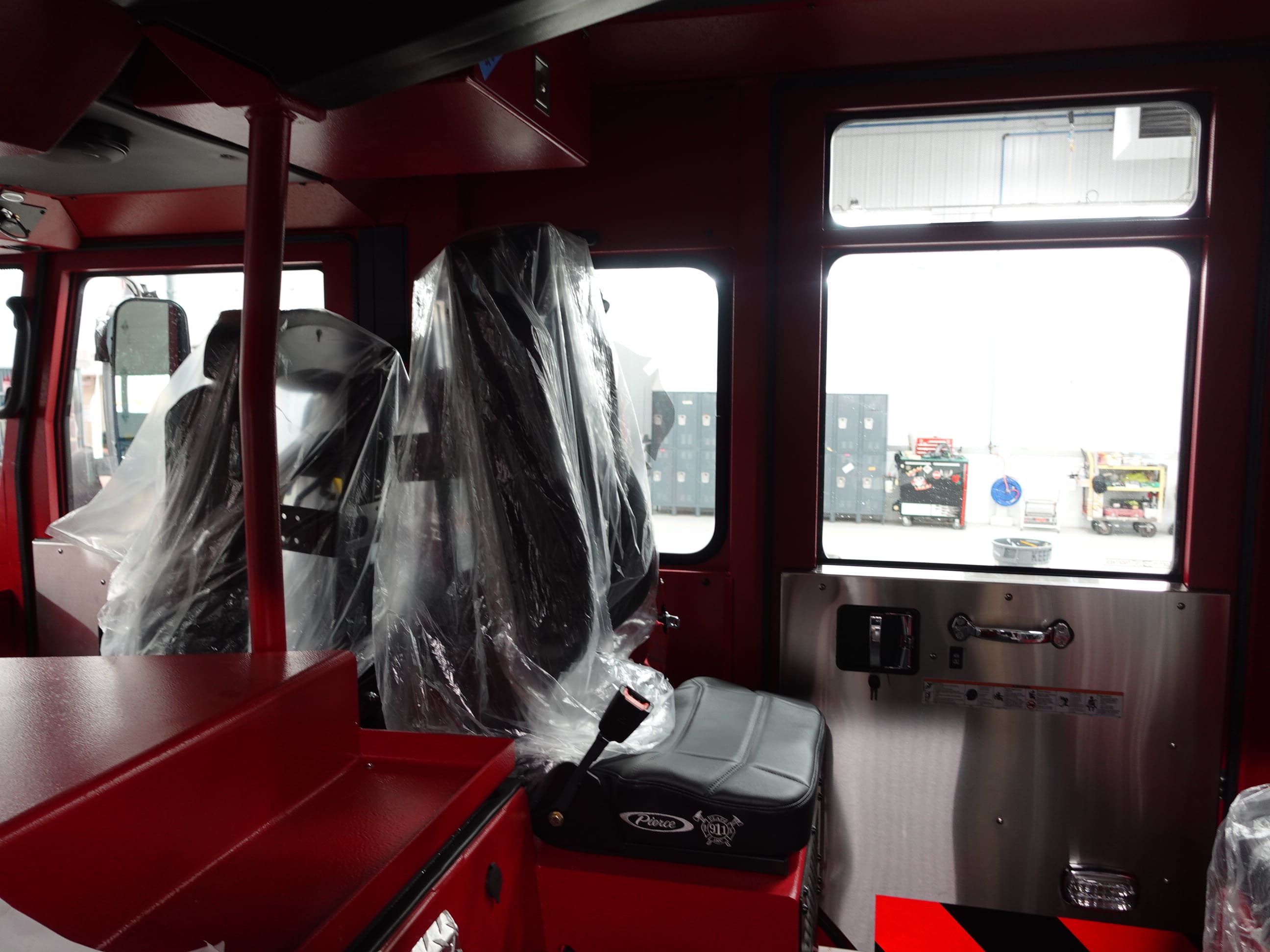

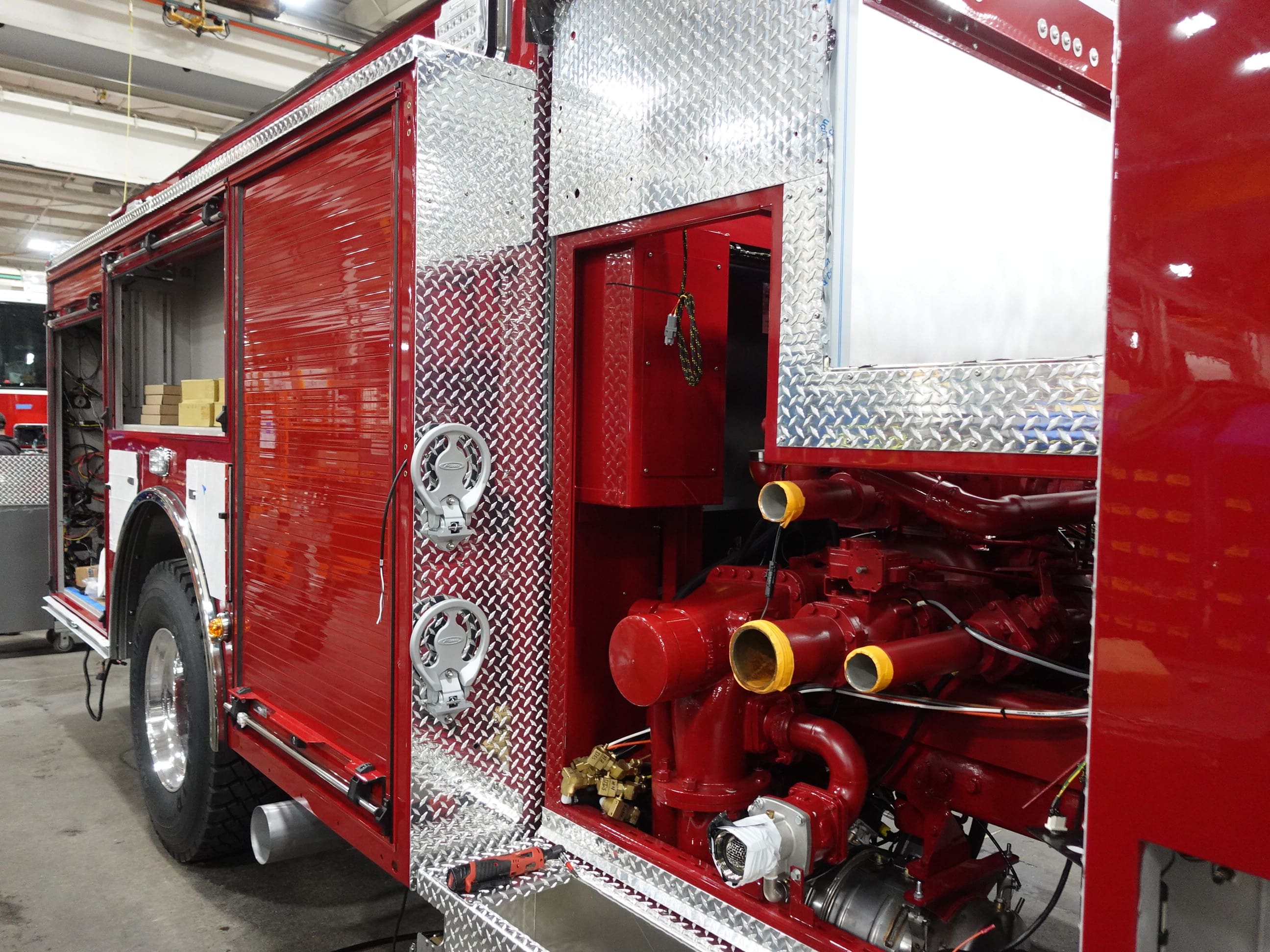

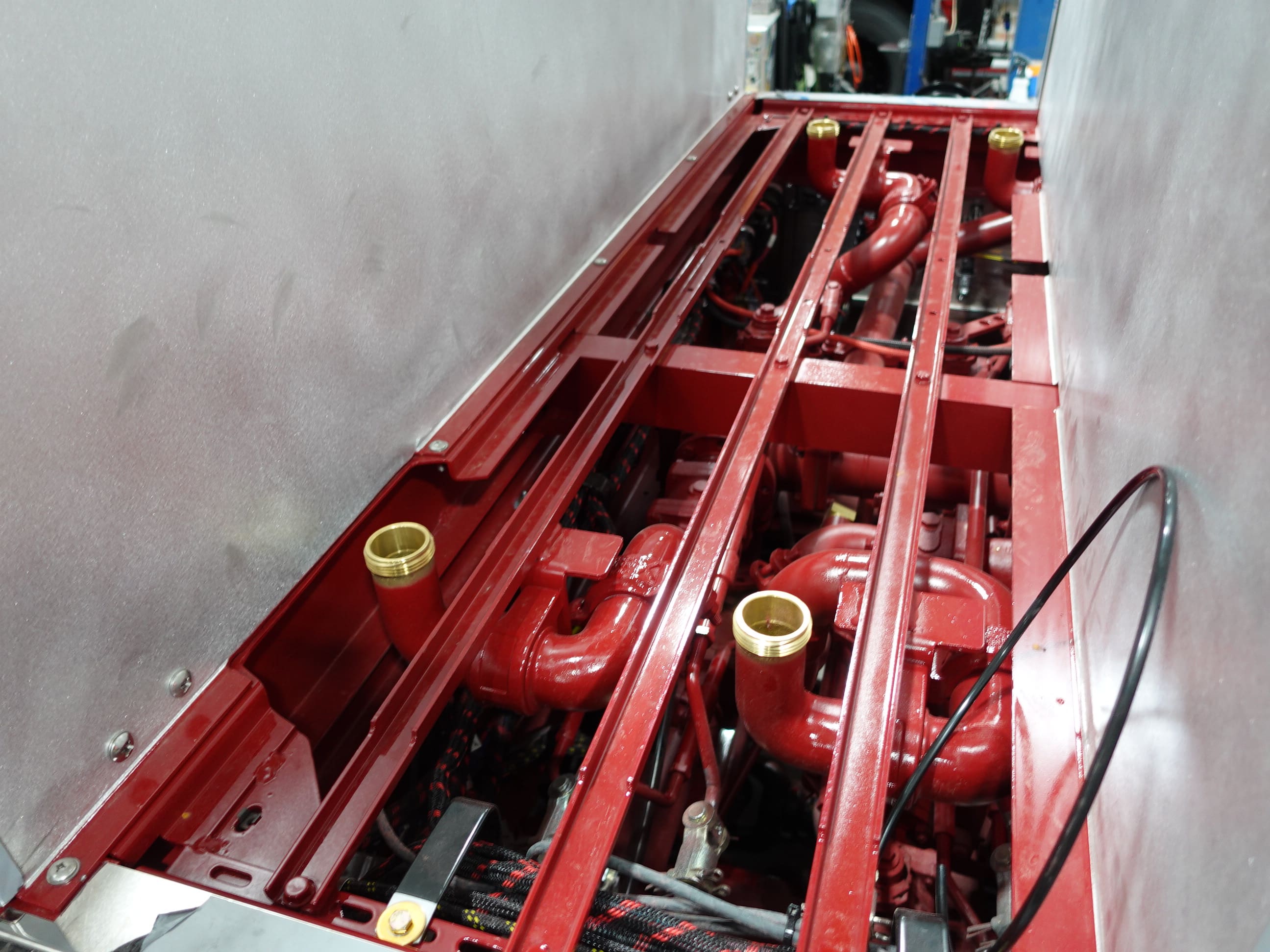

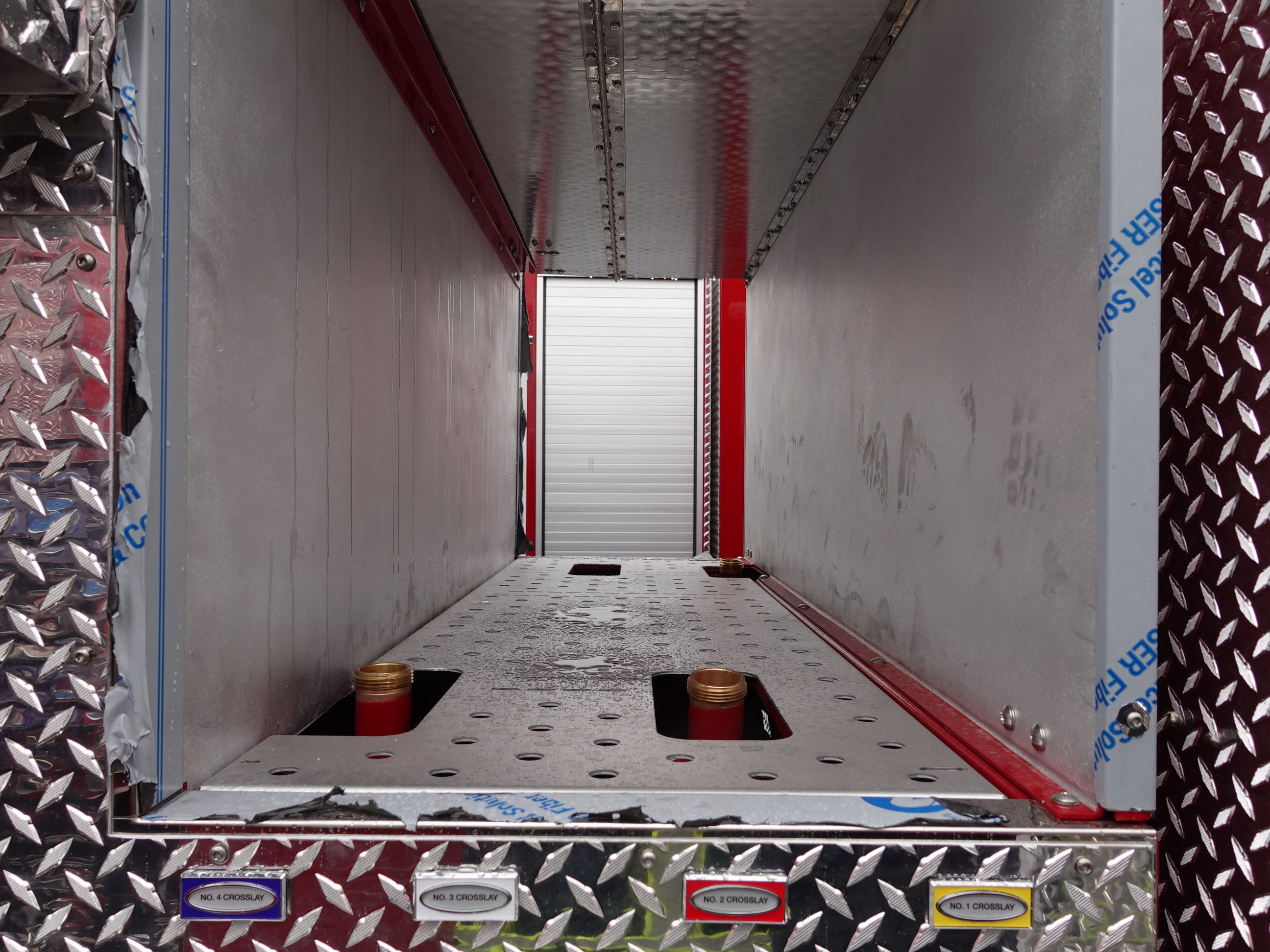

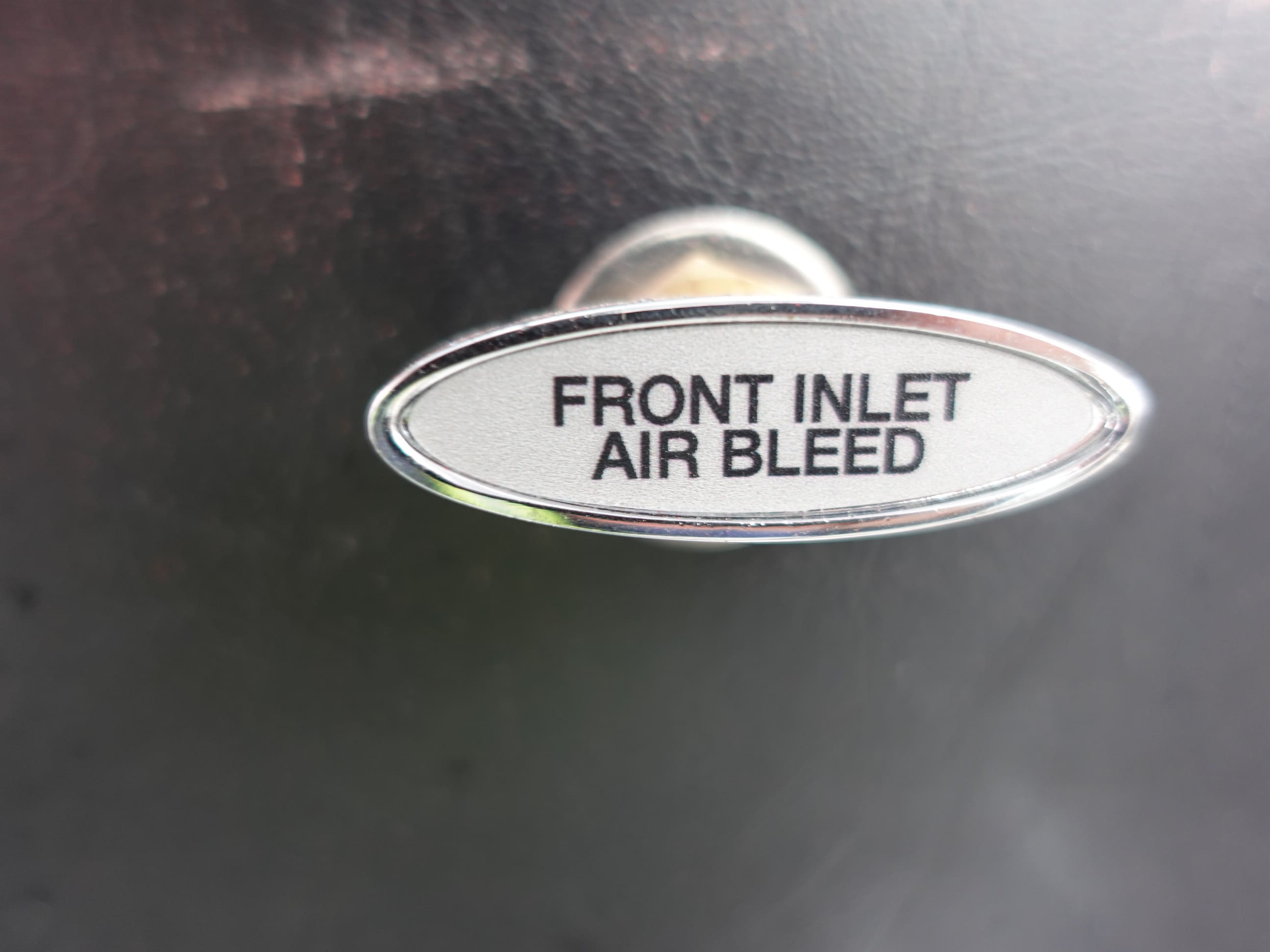

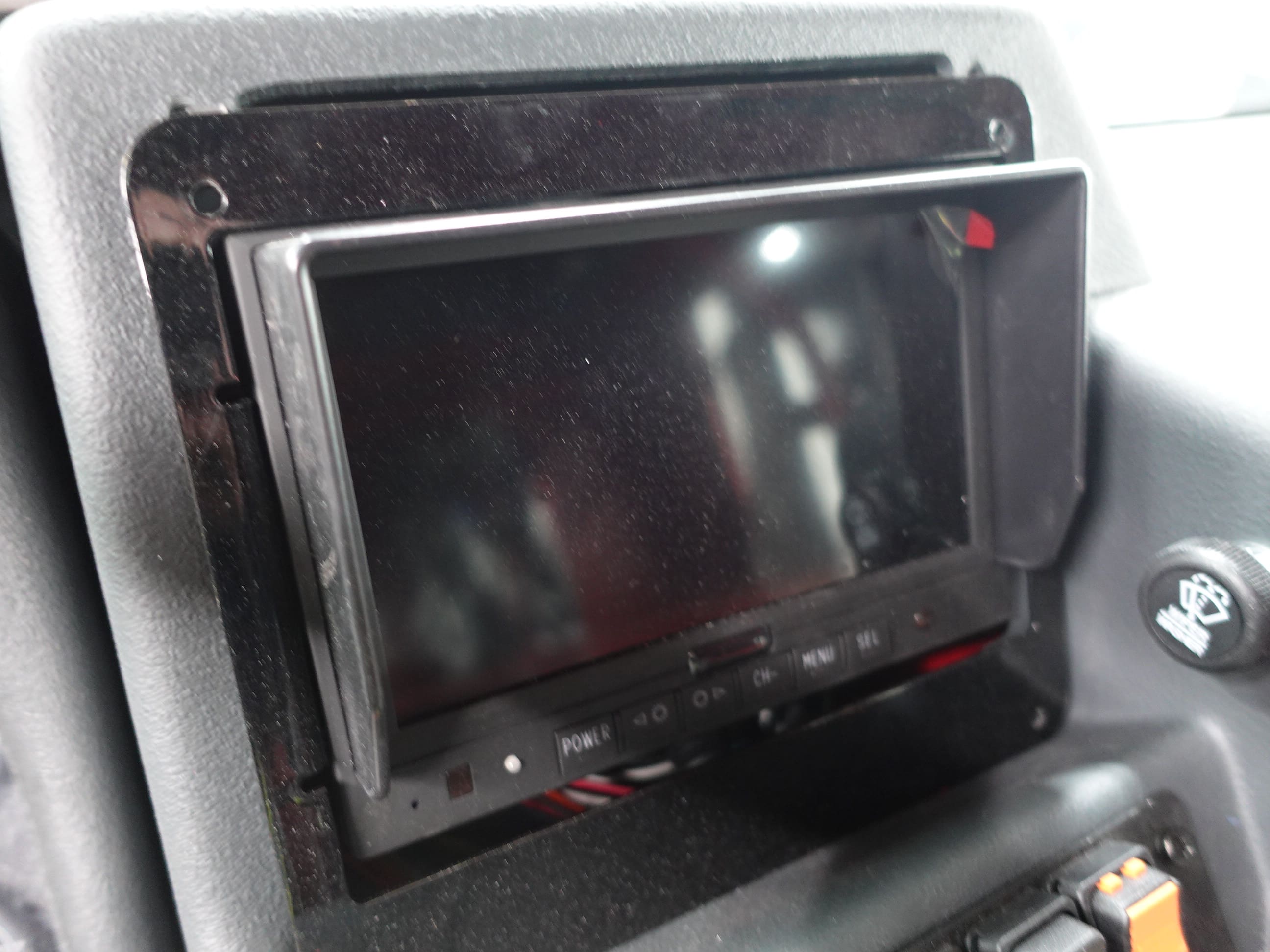

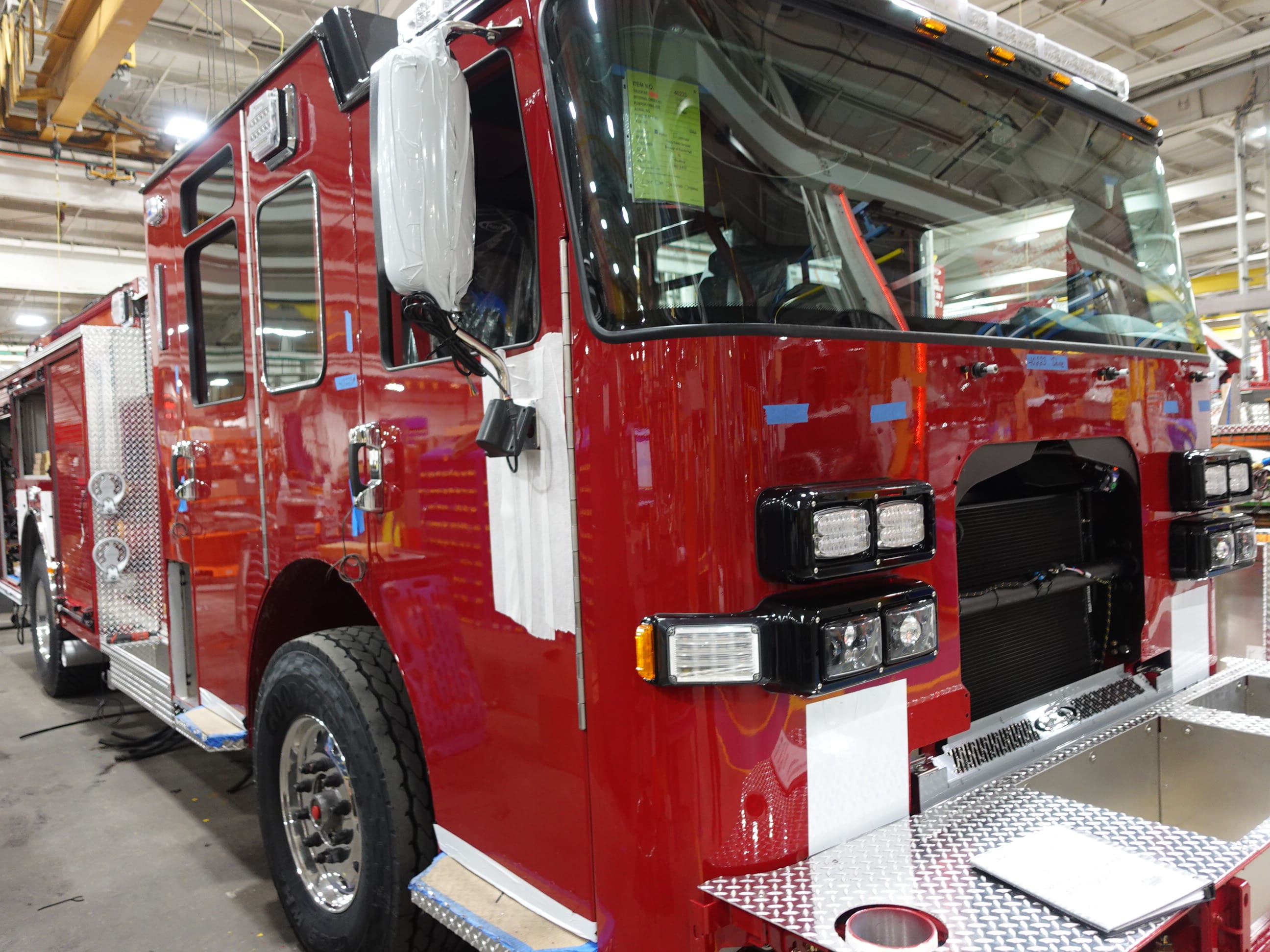

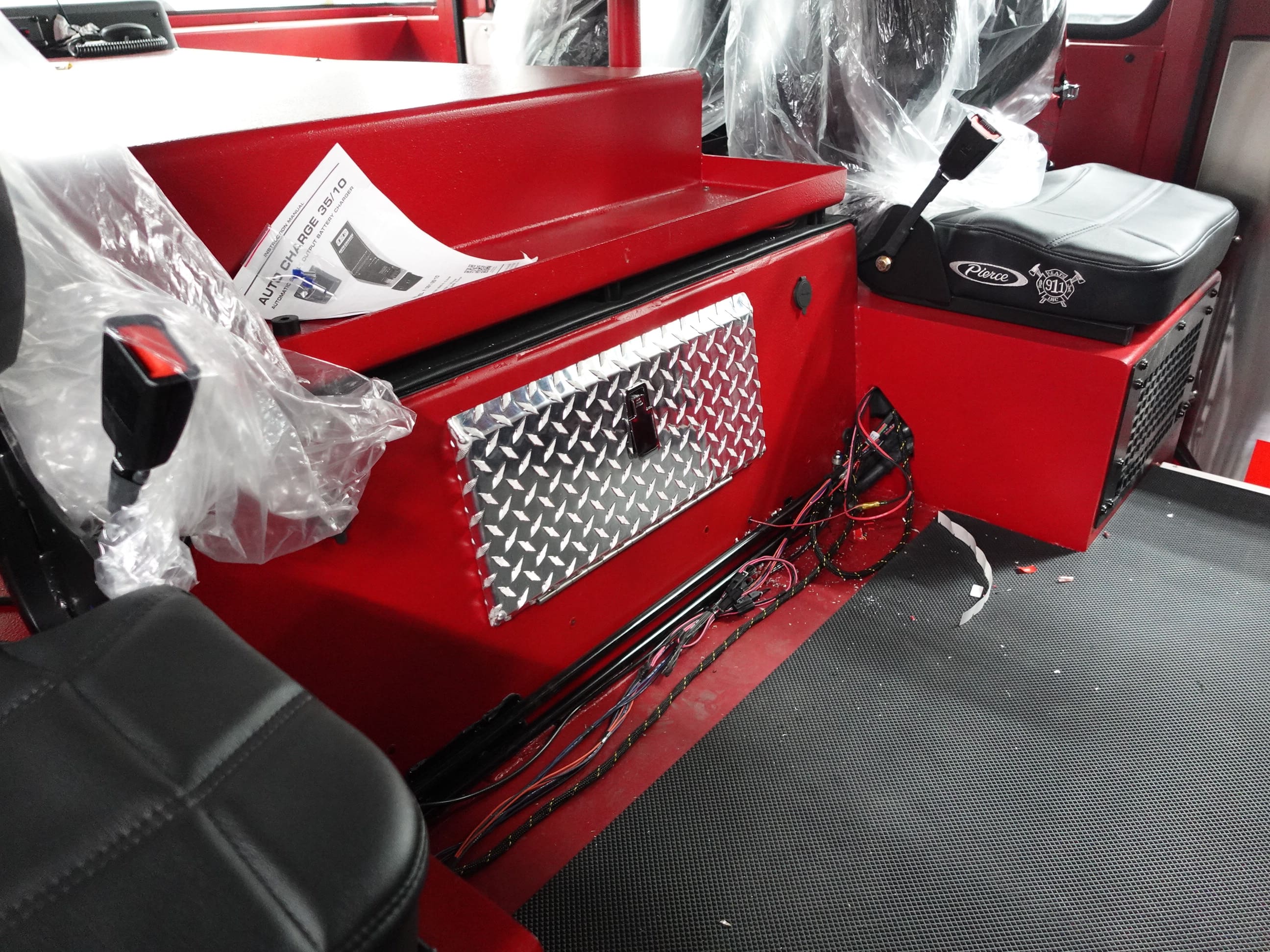

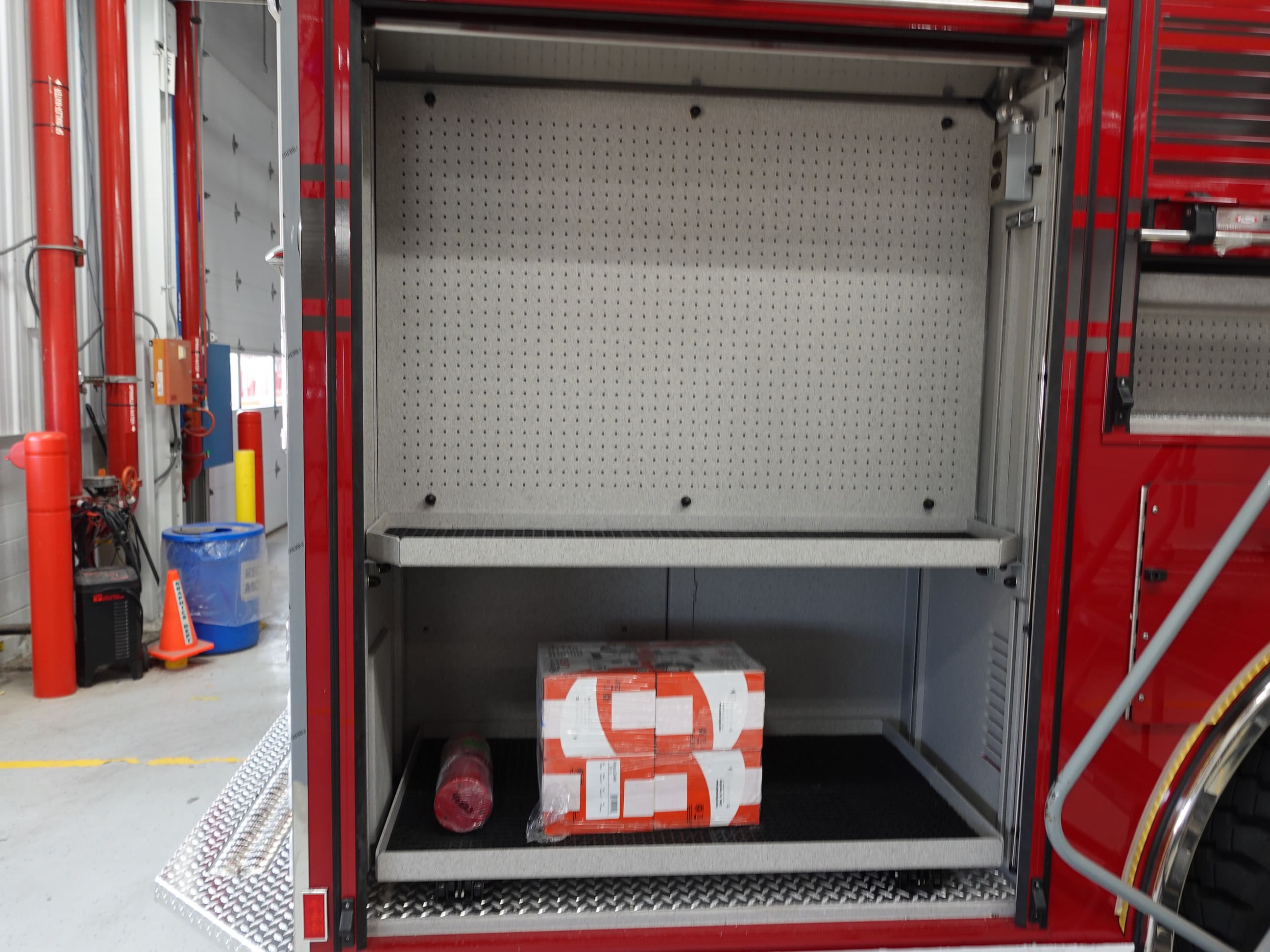

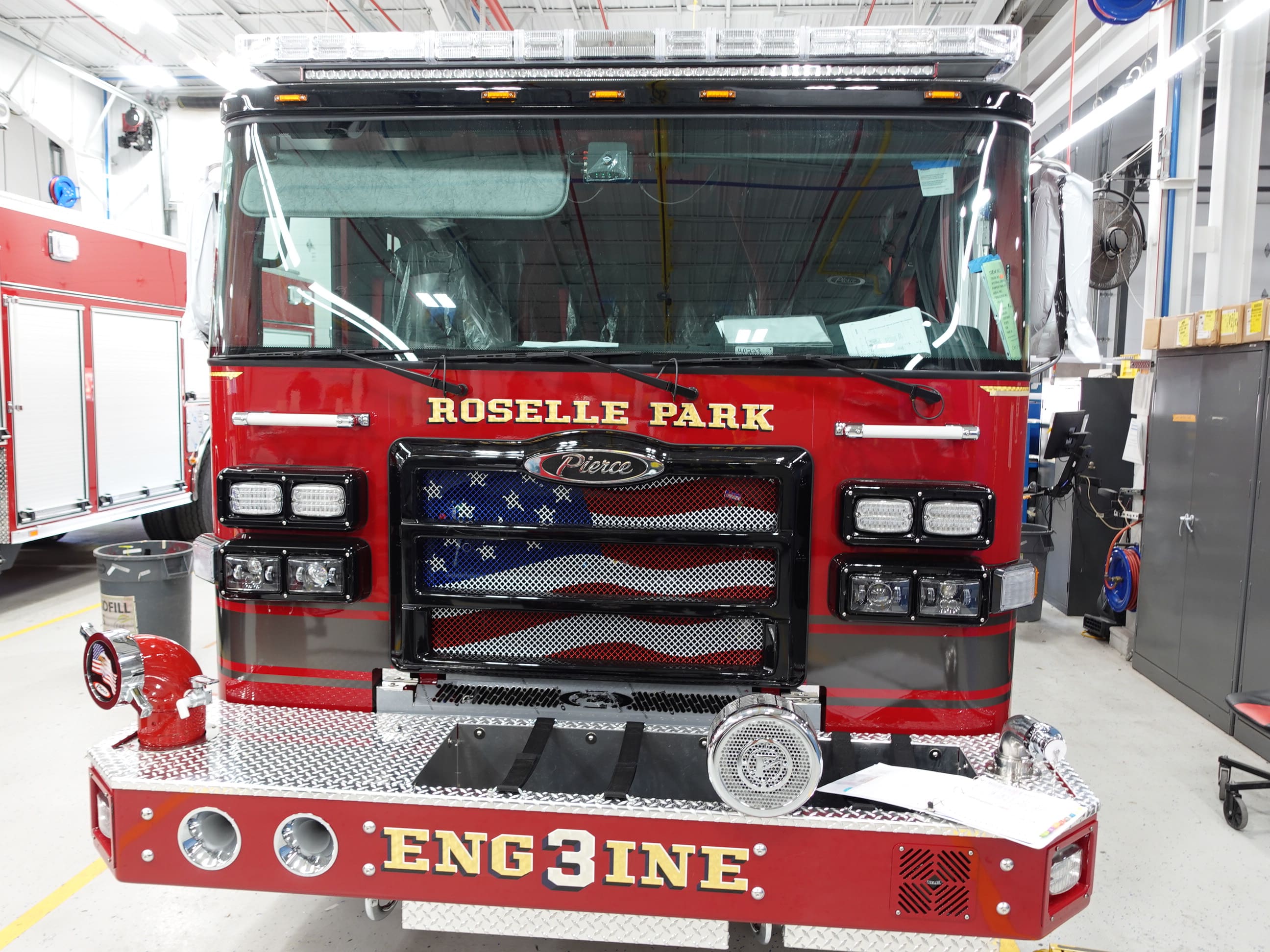

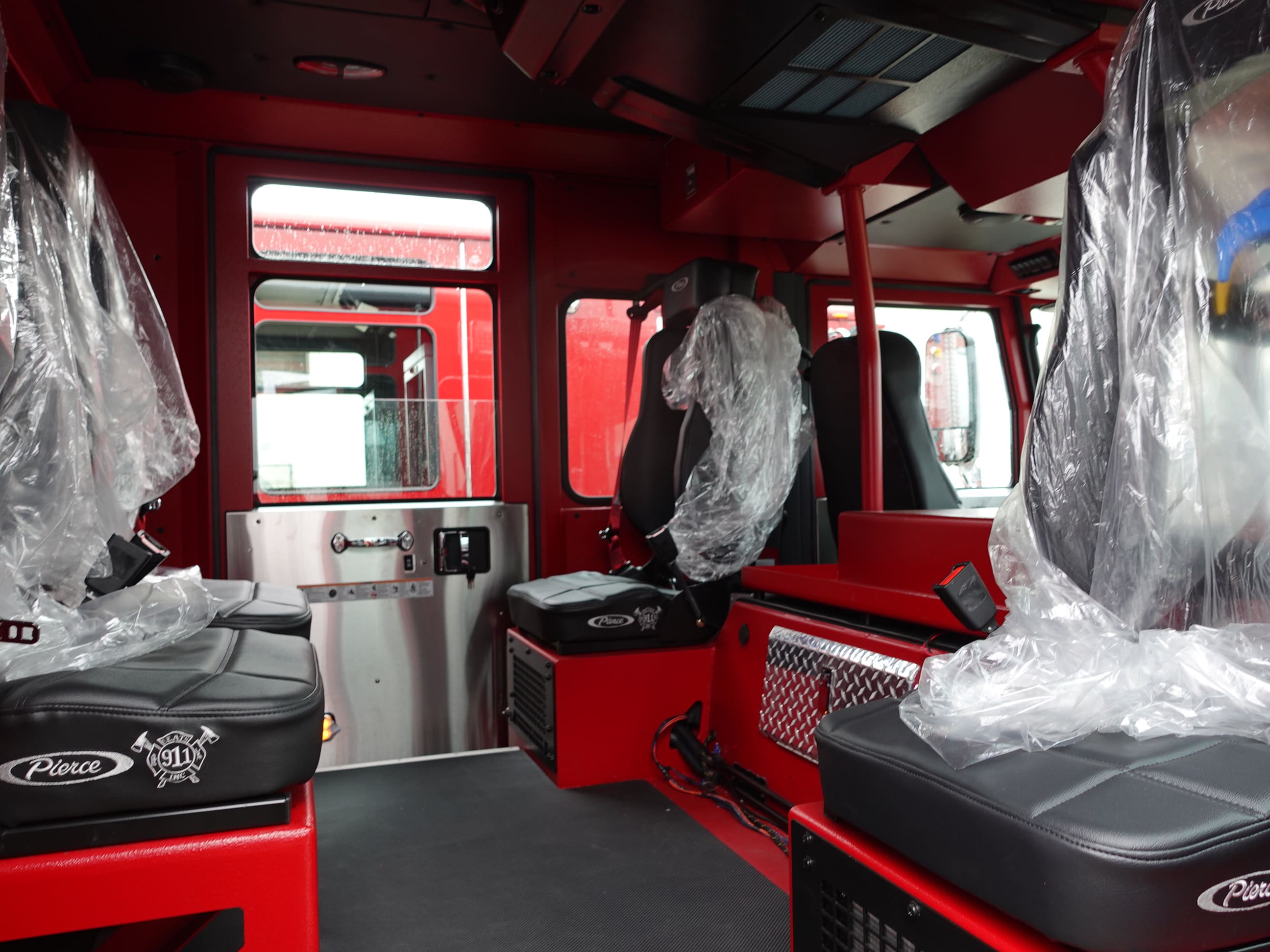

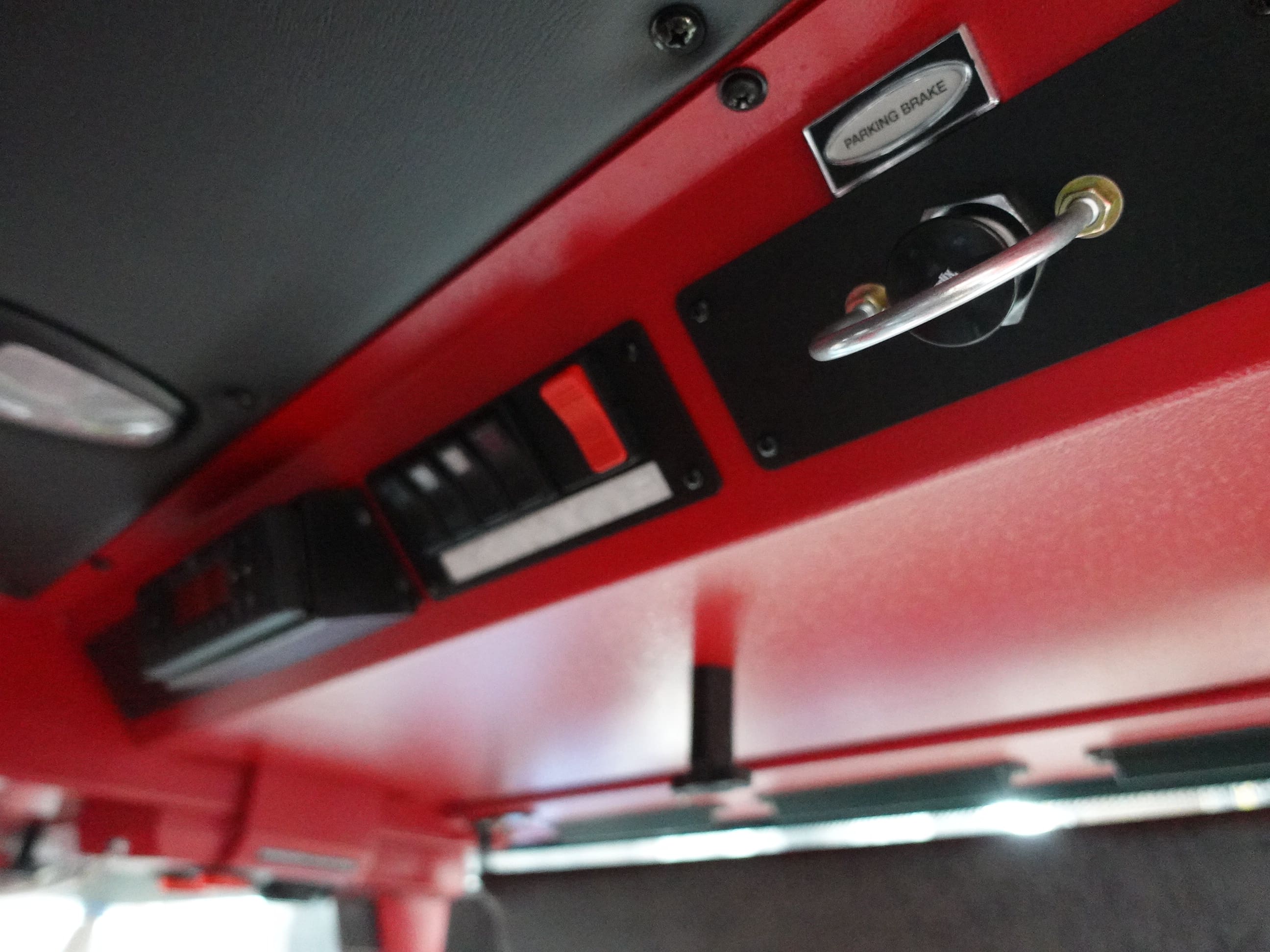

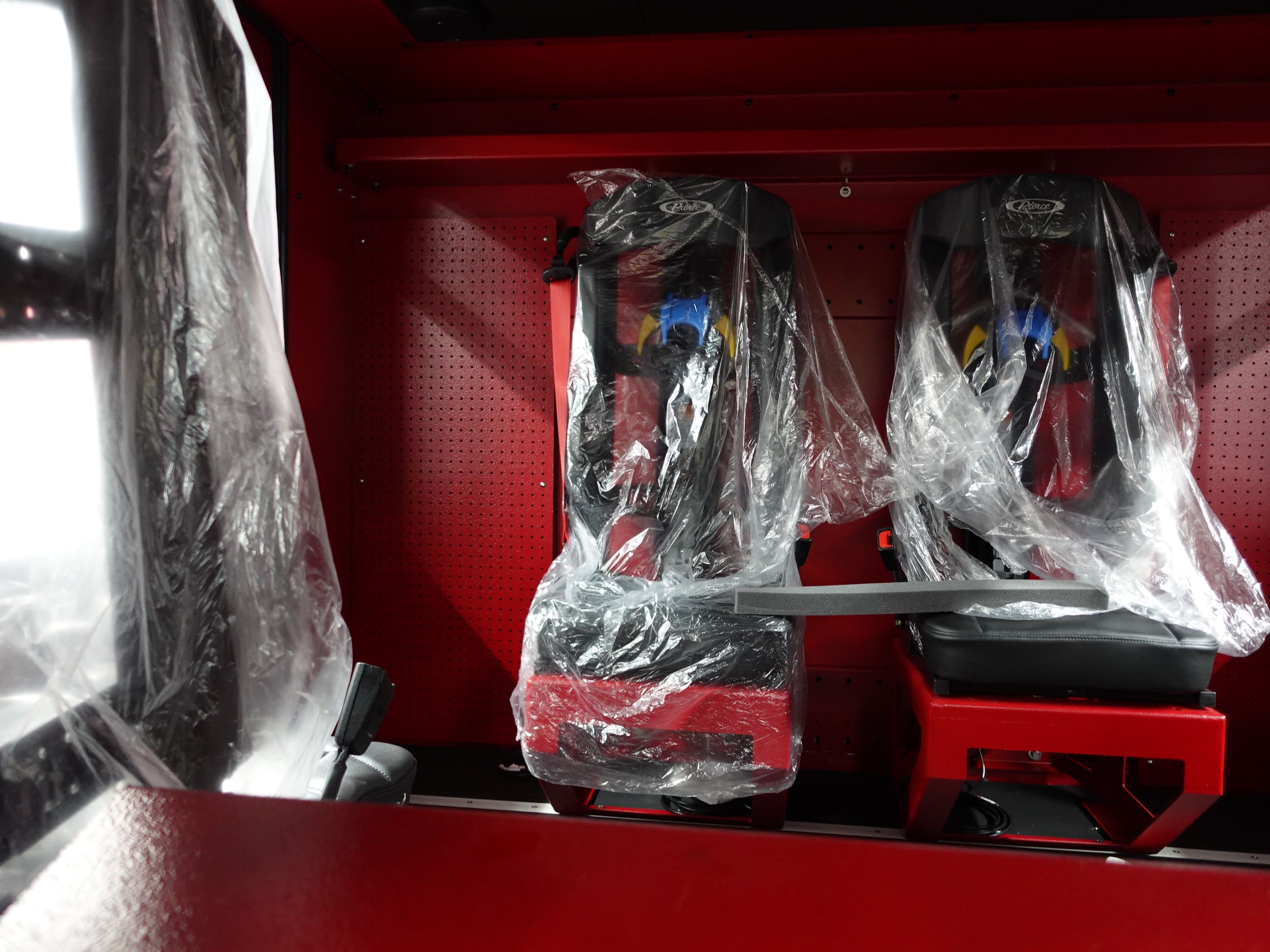

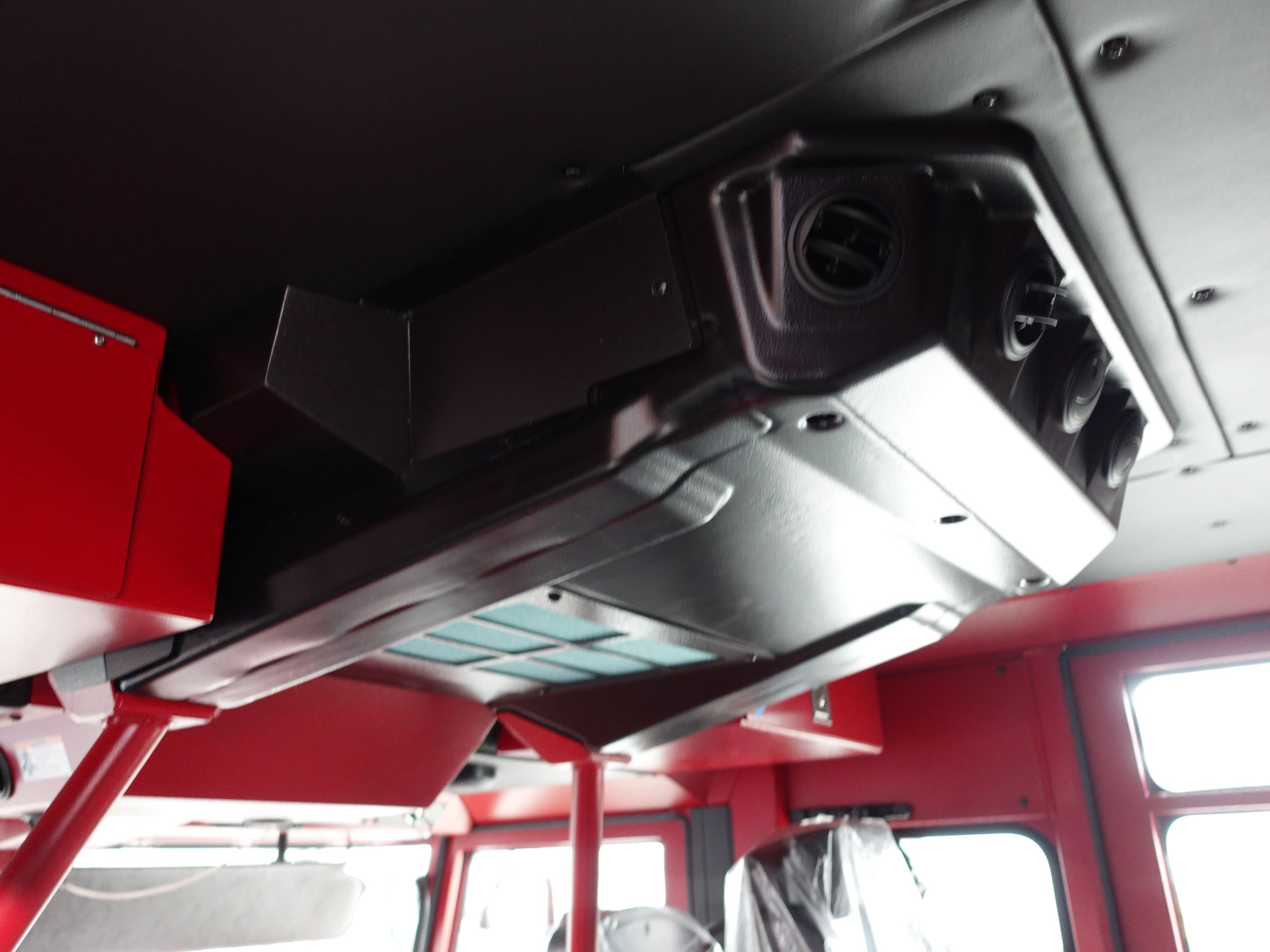

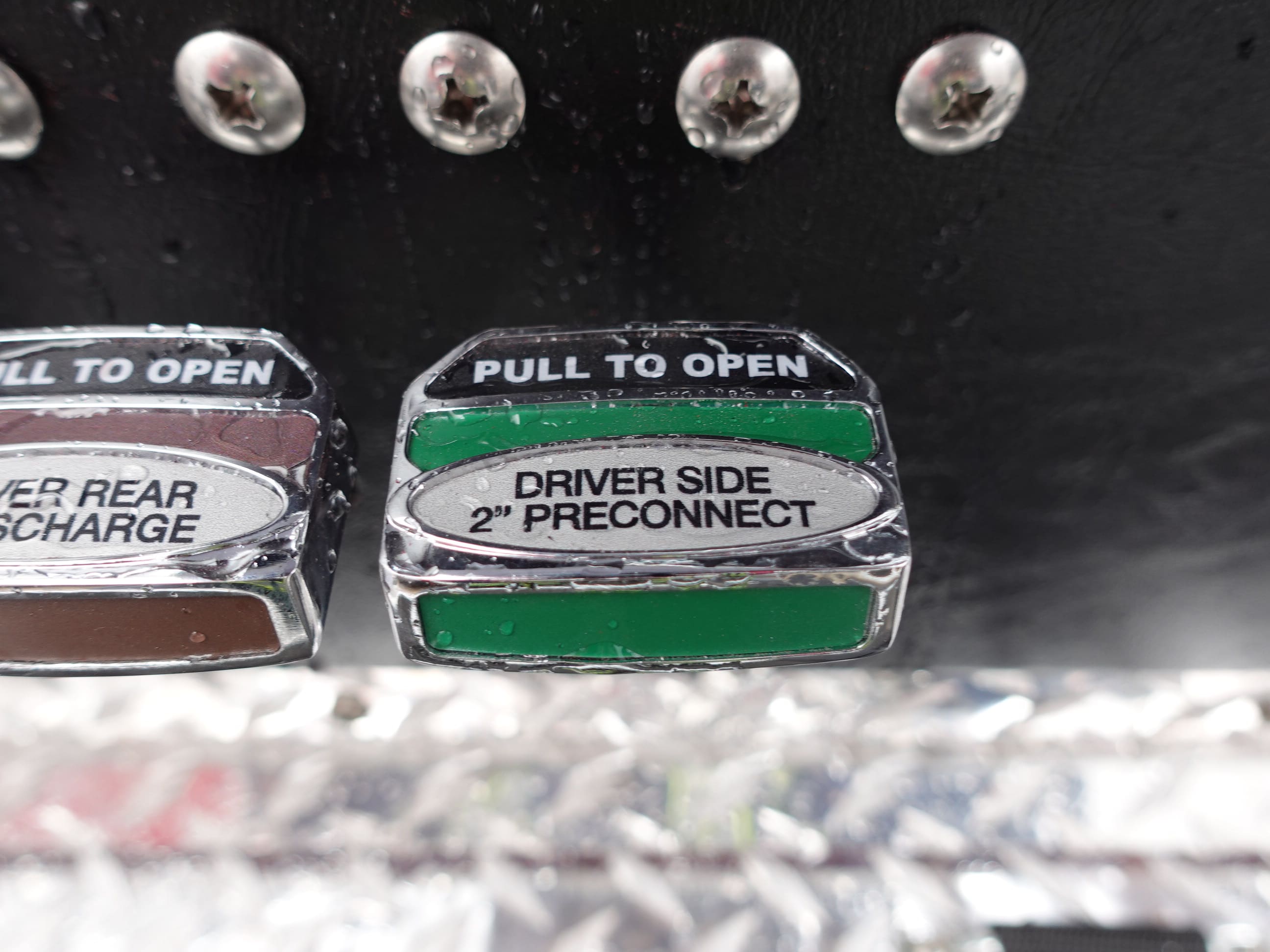

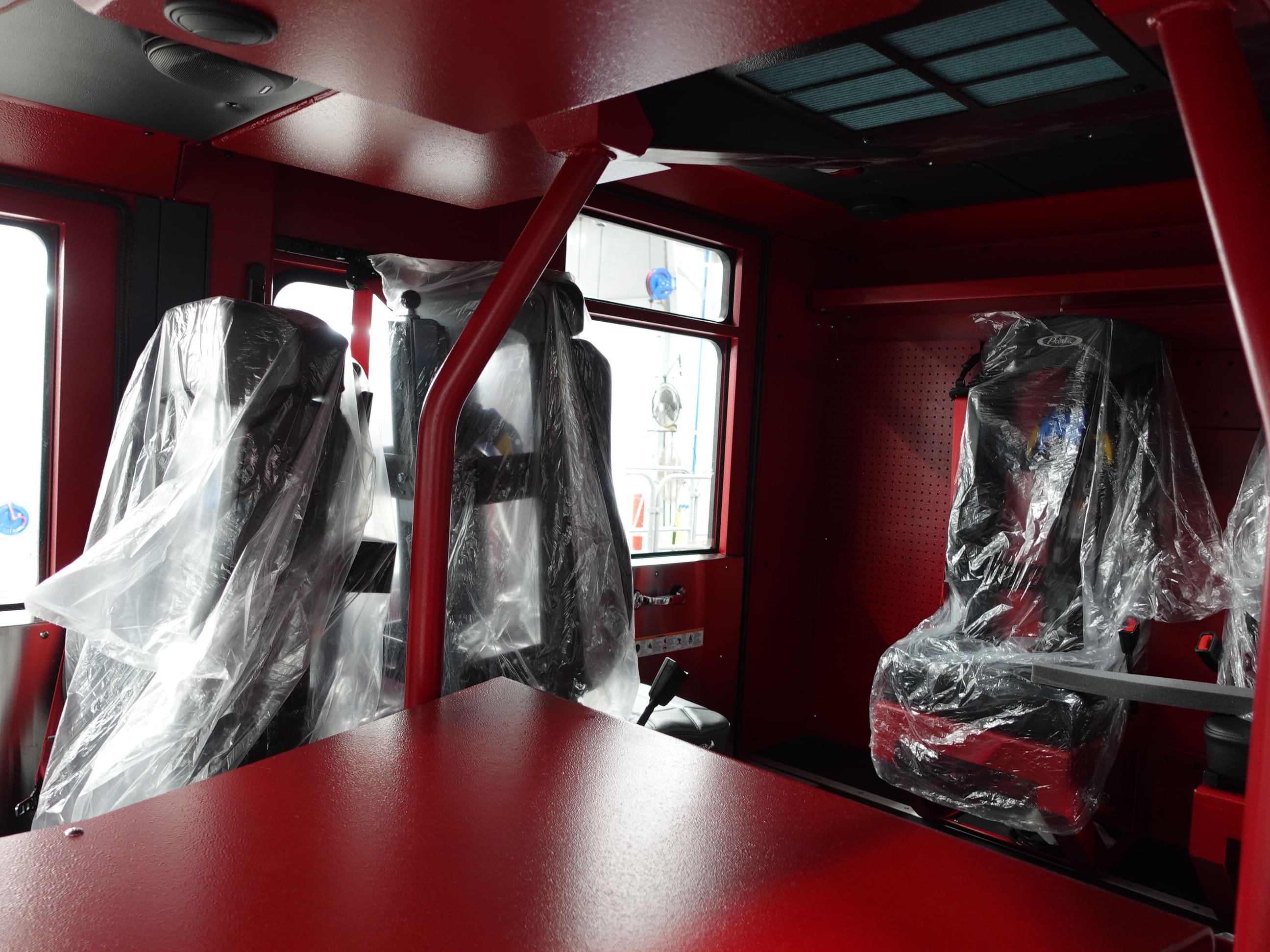

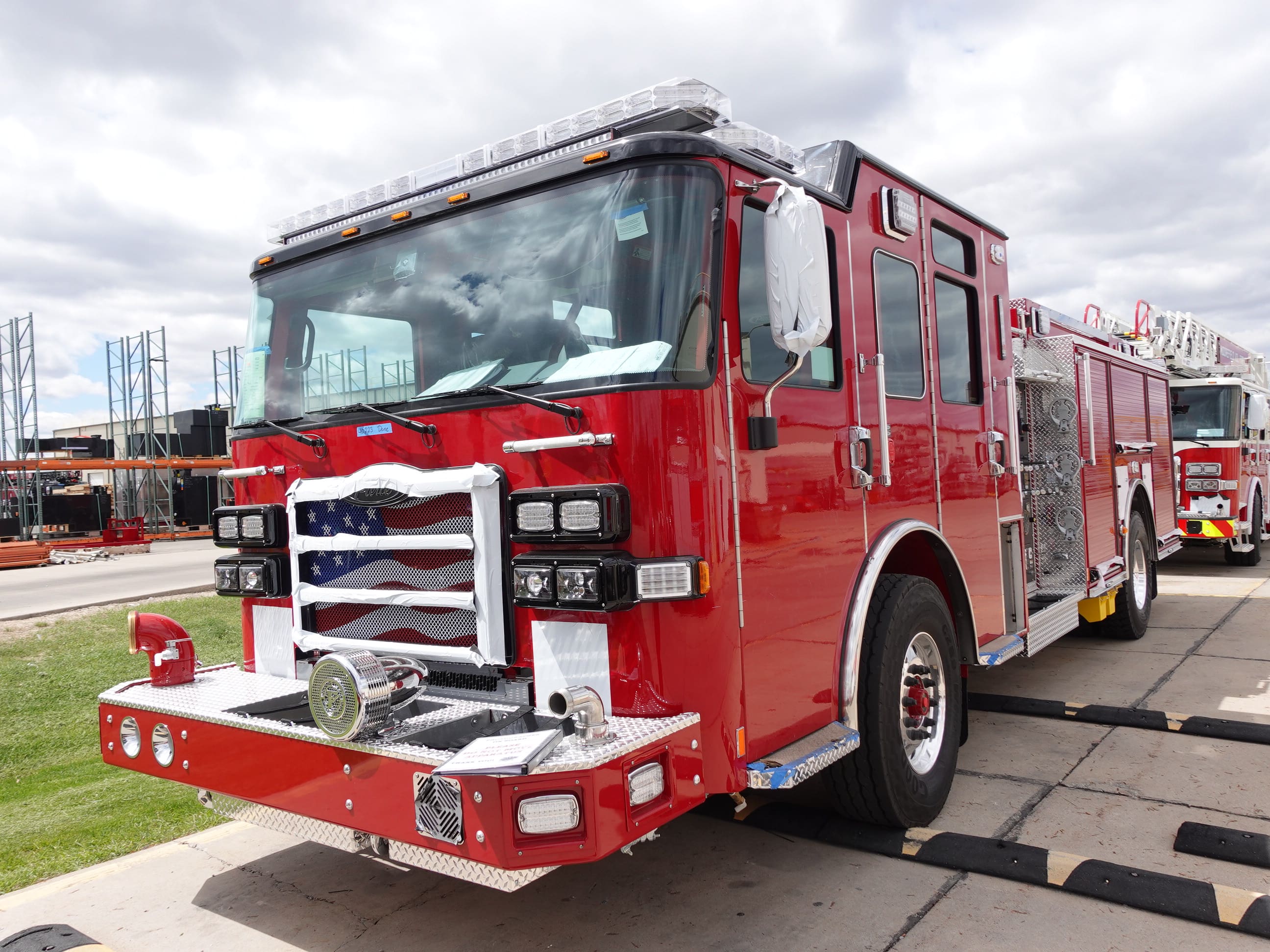

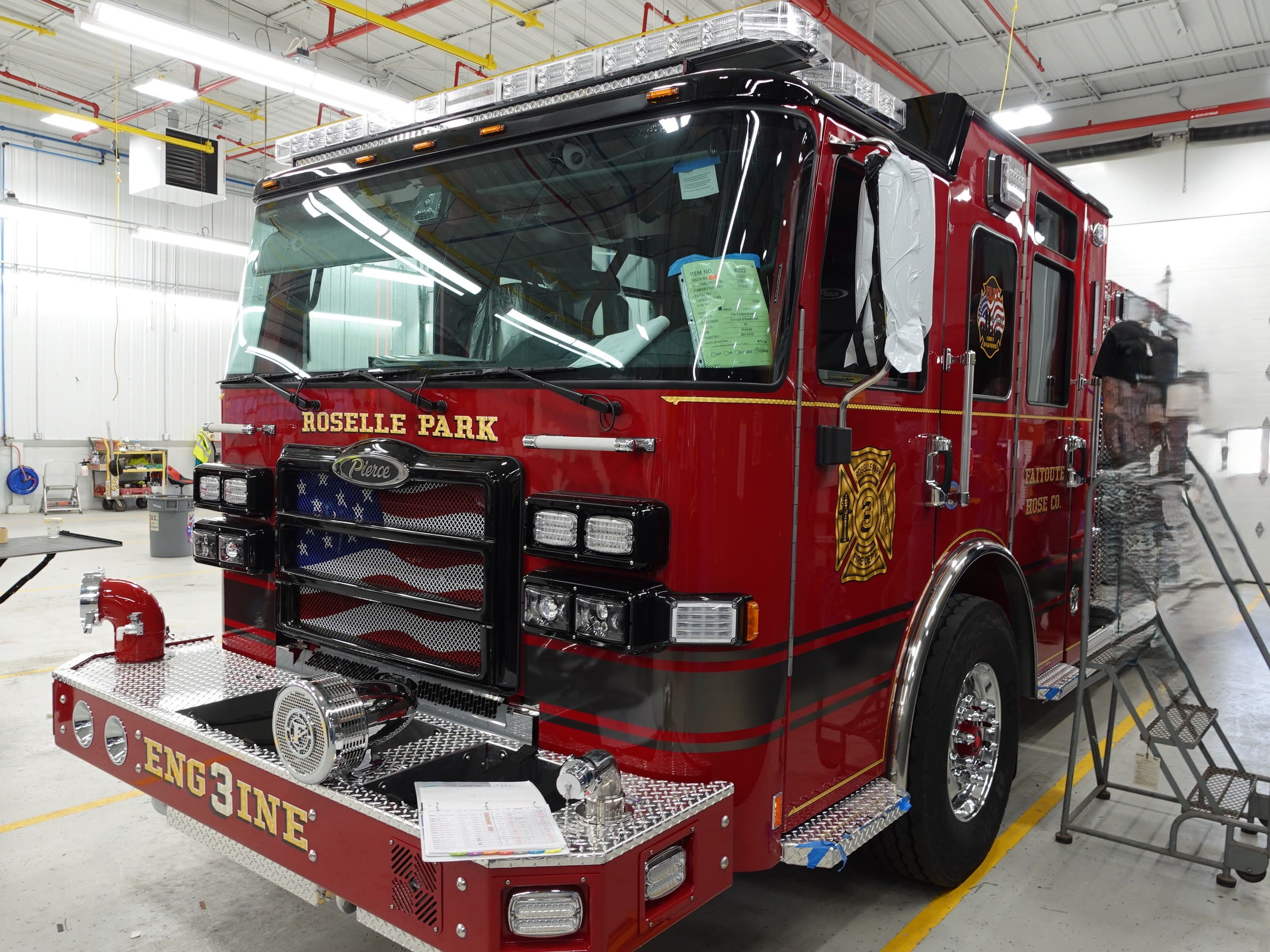

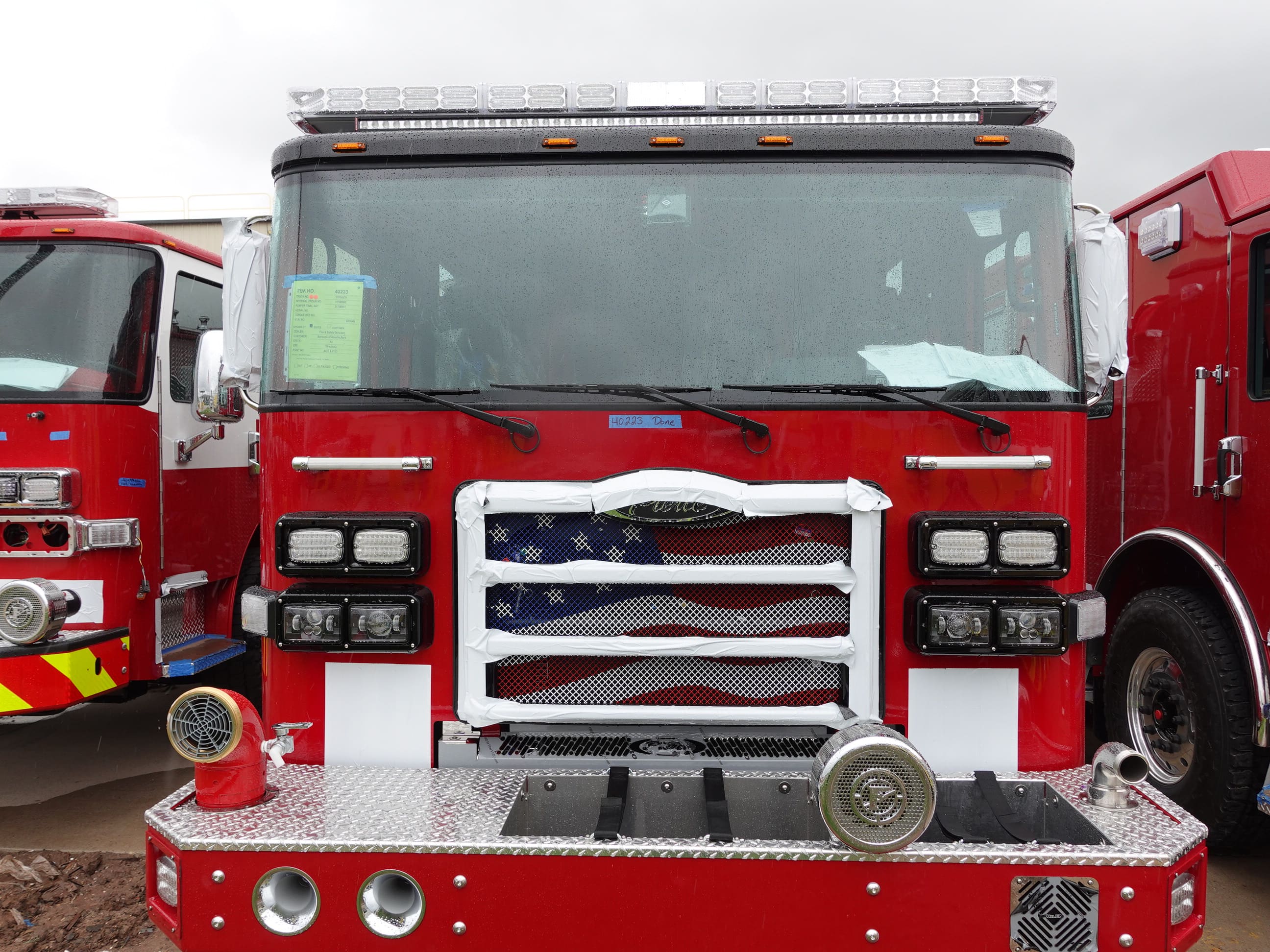

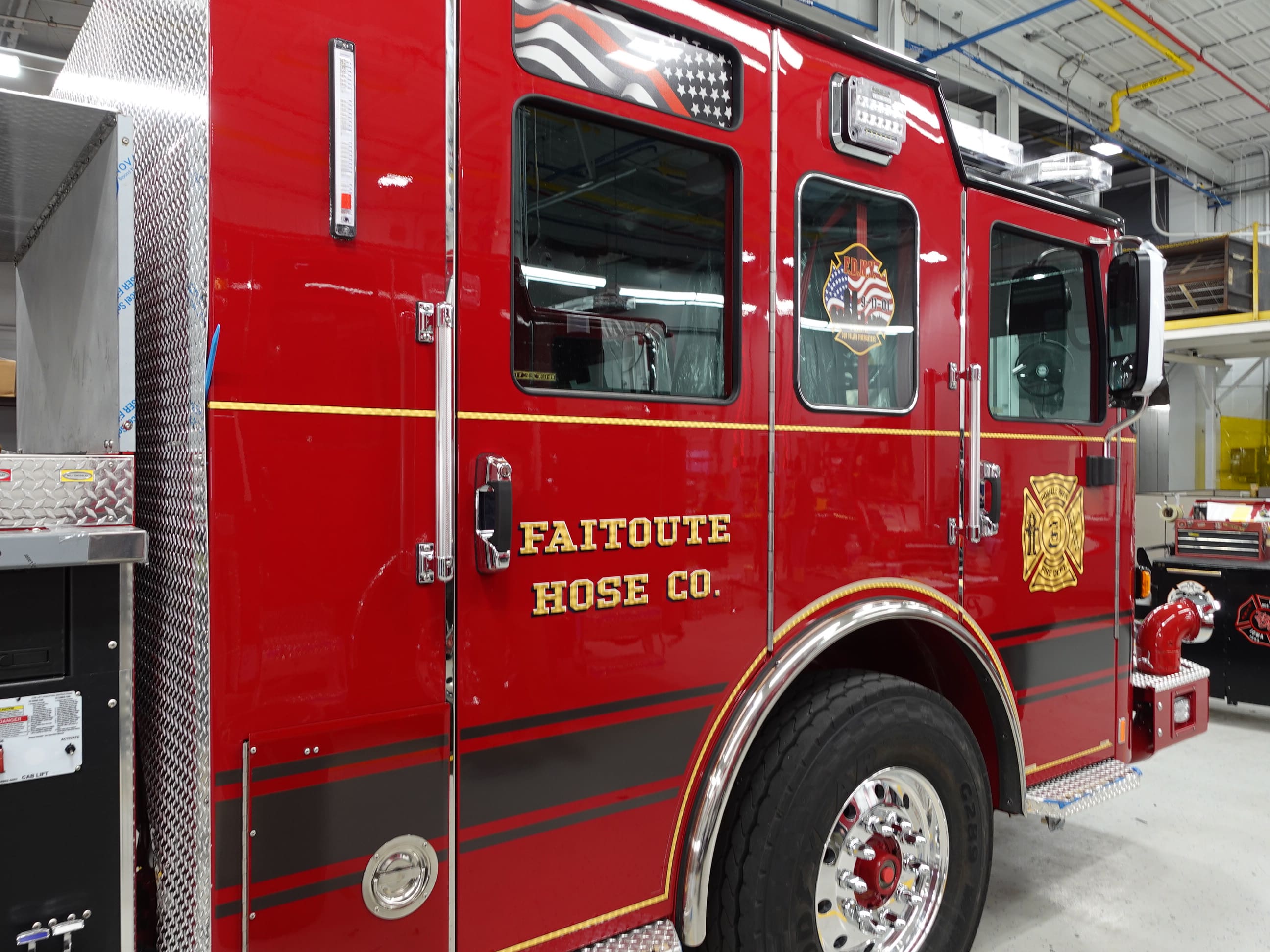

In this report, the apparatus completed testing
then released to quality and graphics where any

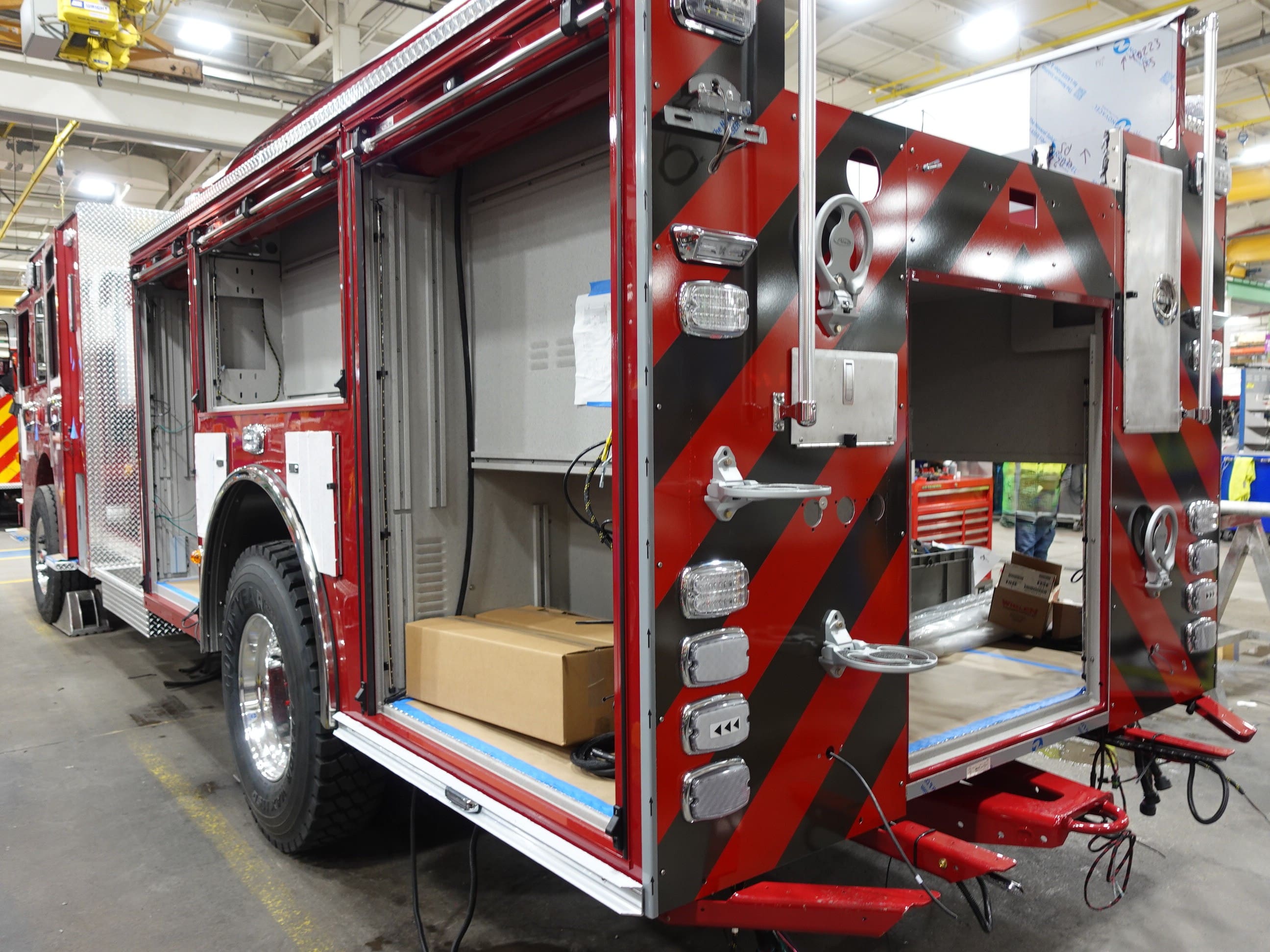

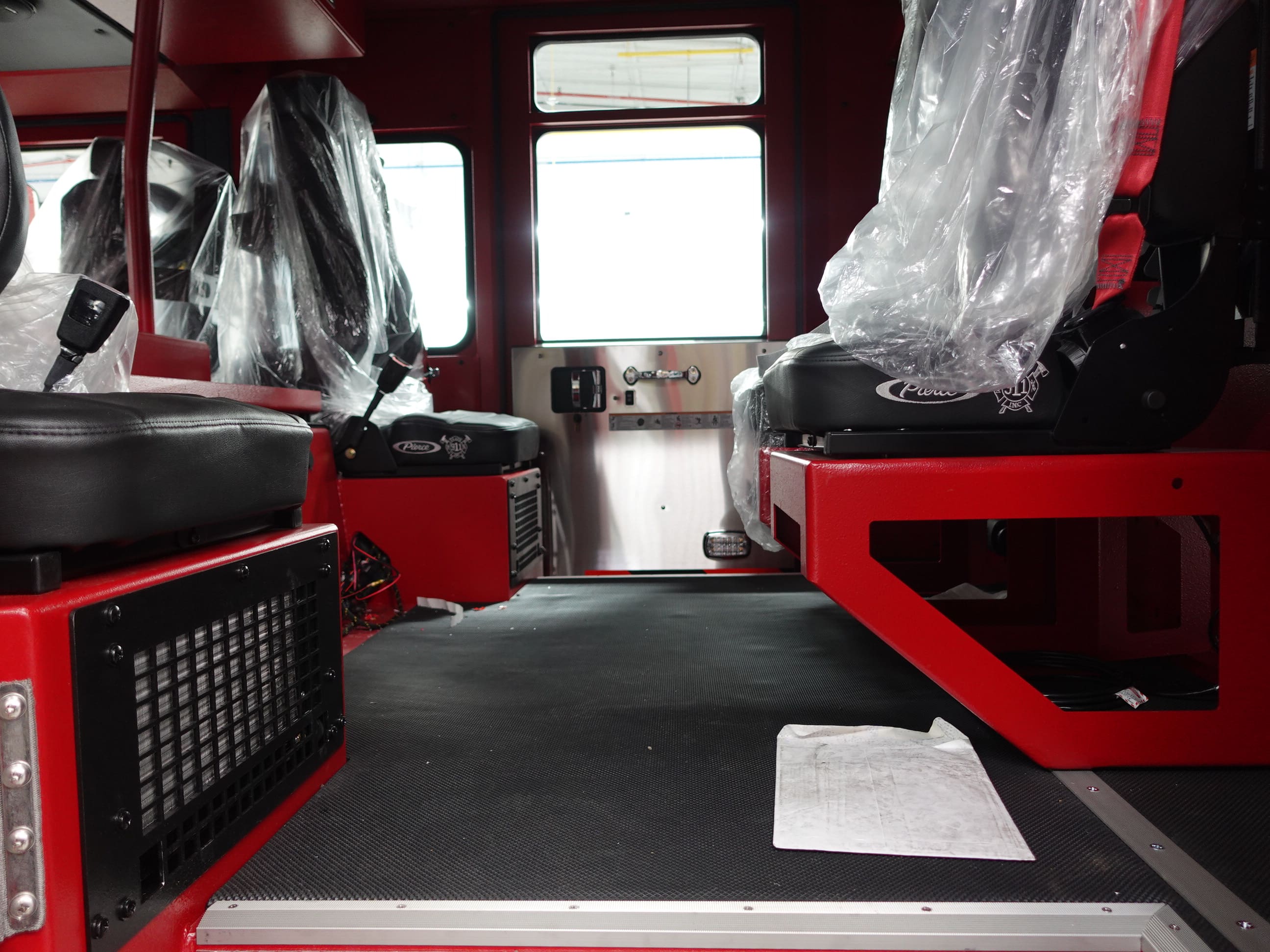

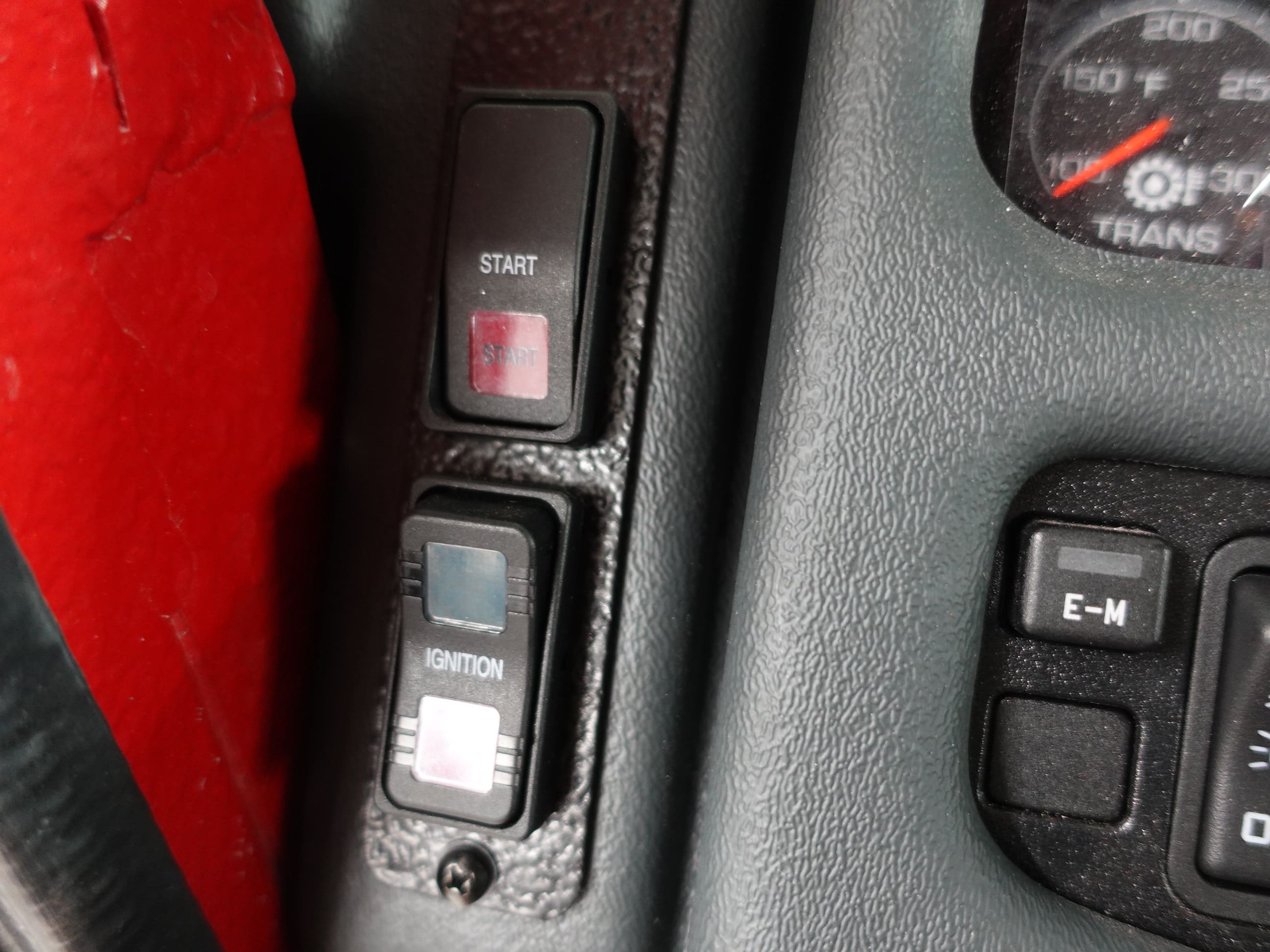

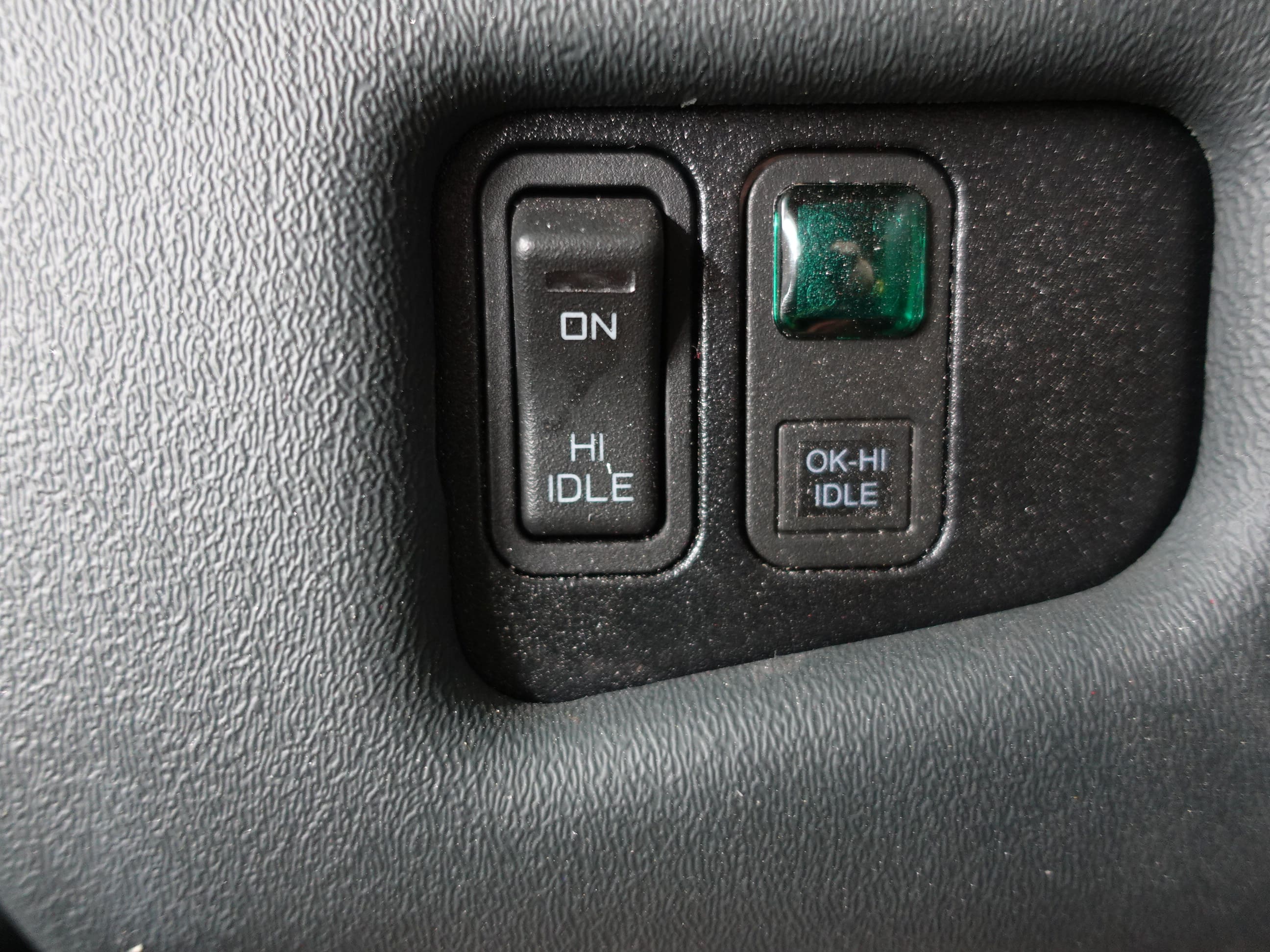

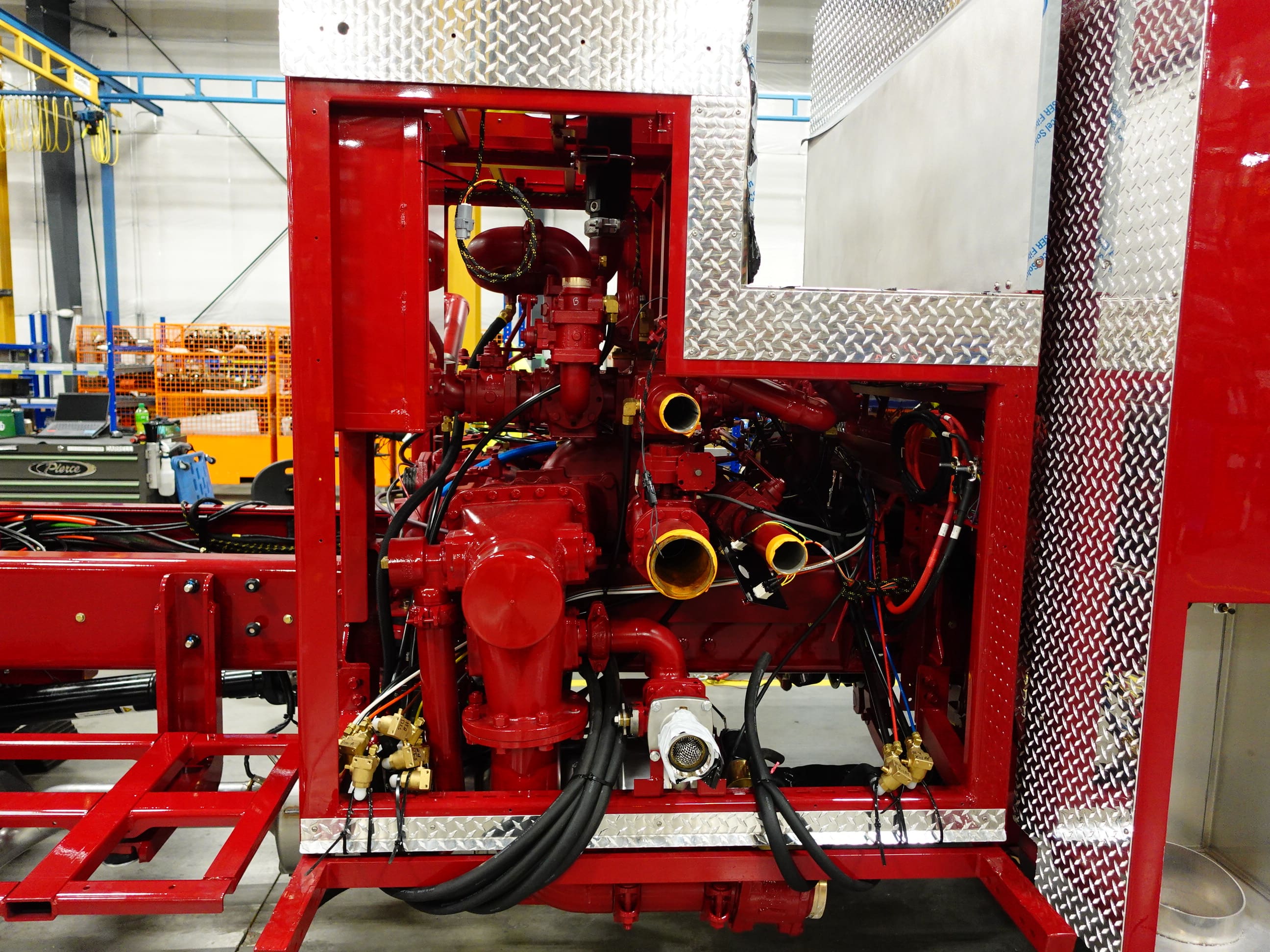

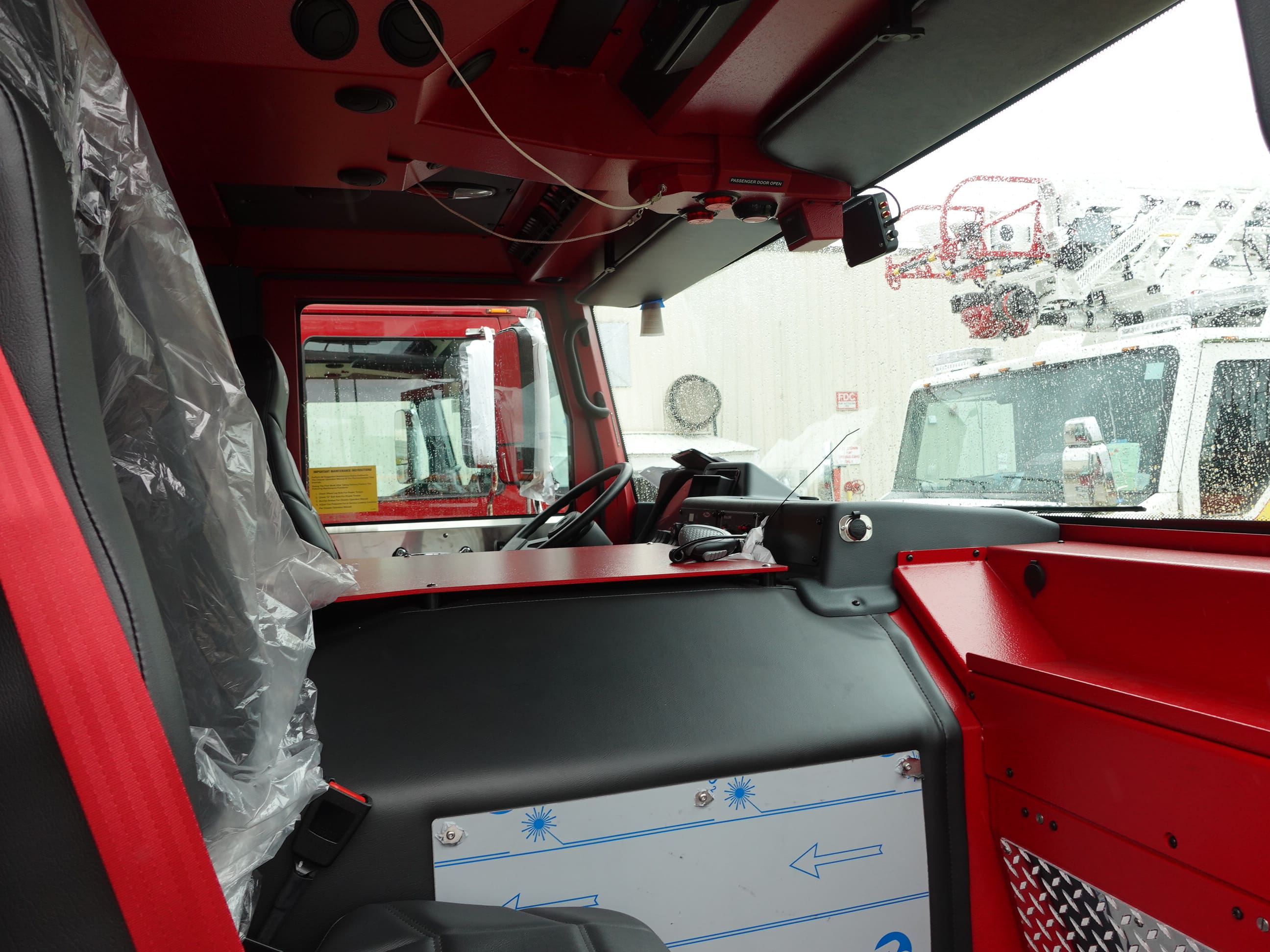

remaining content will be applied. Once finished it
will be made ready for your customer acceptance

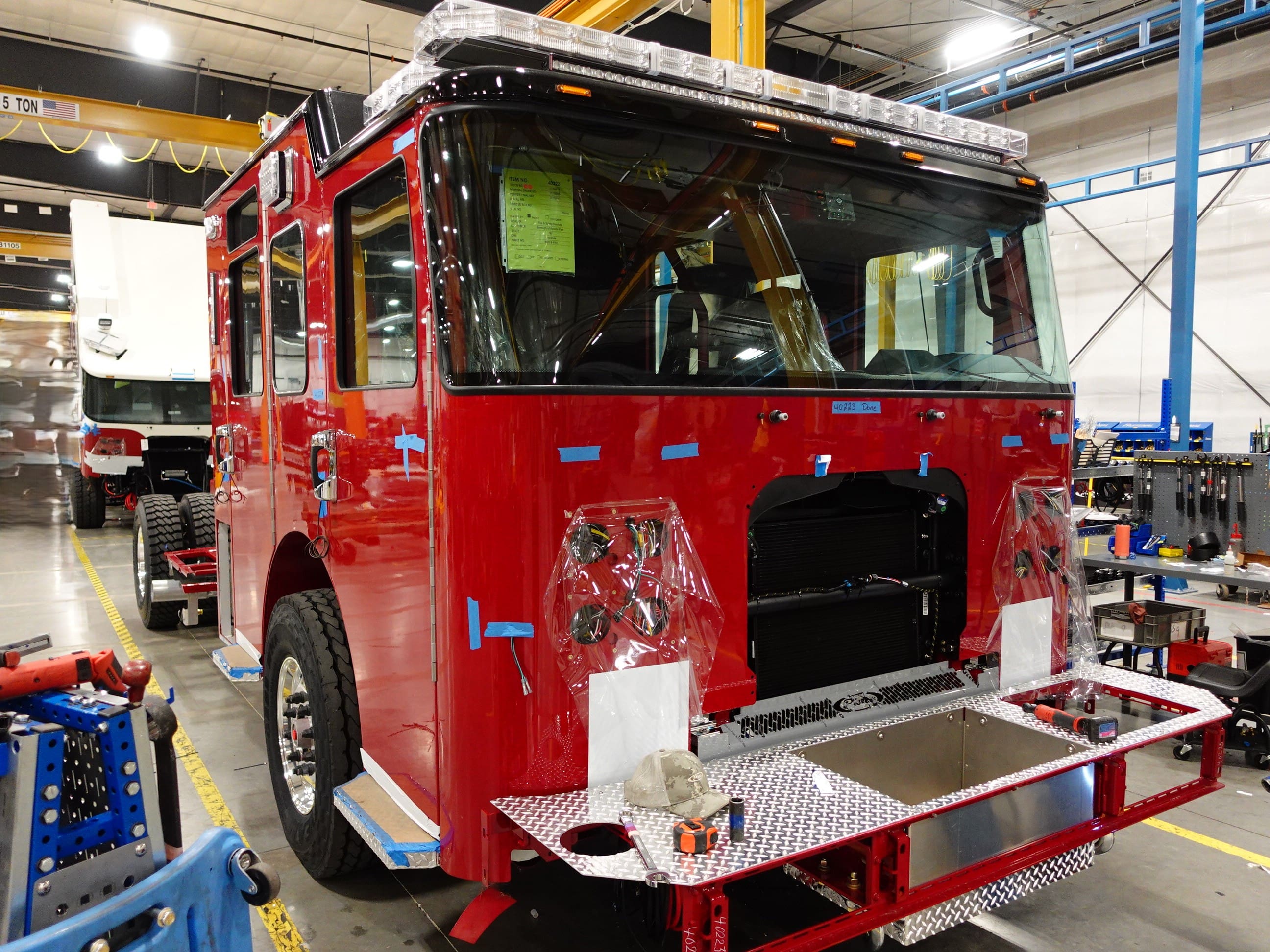

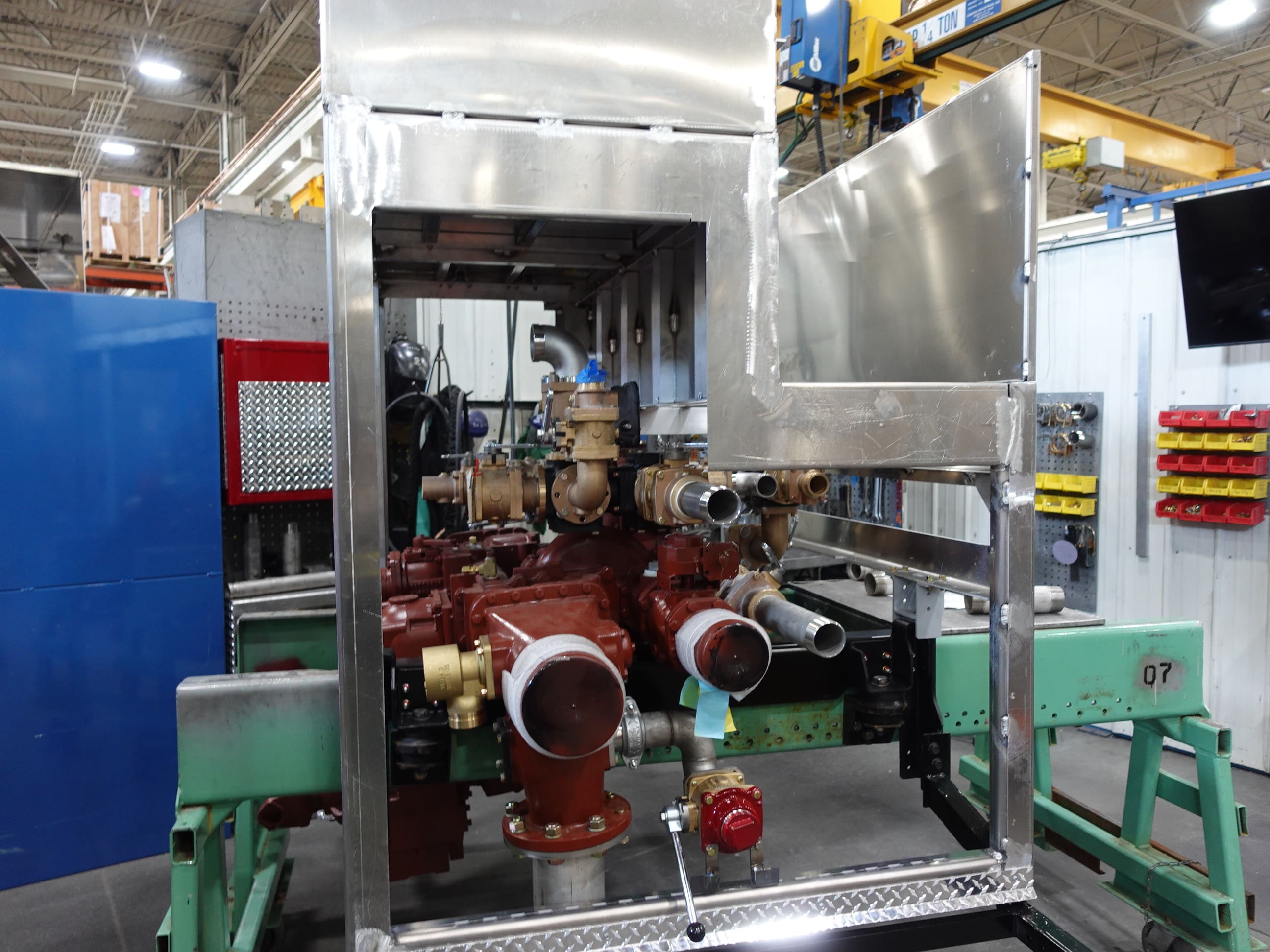

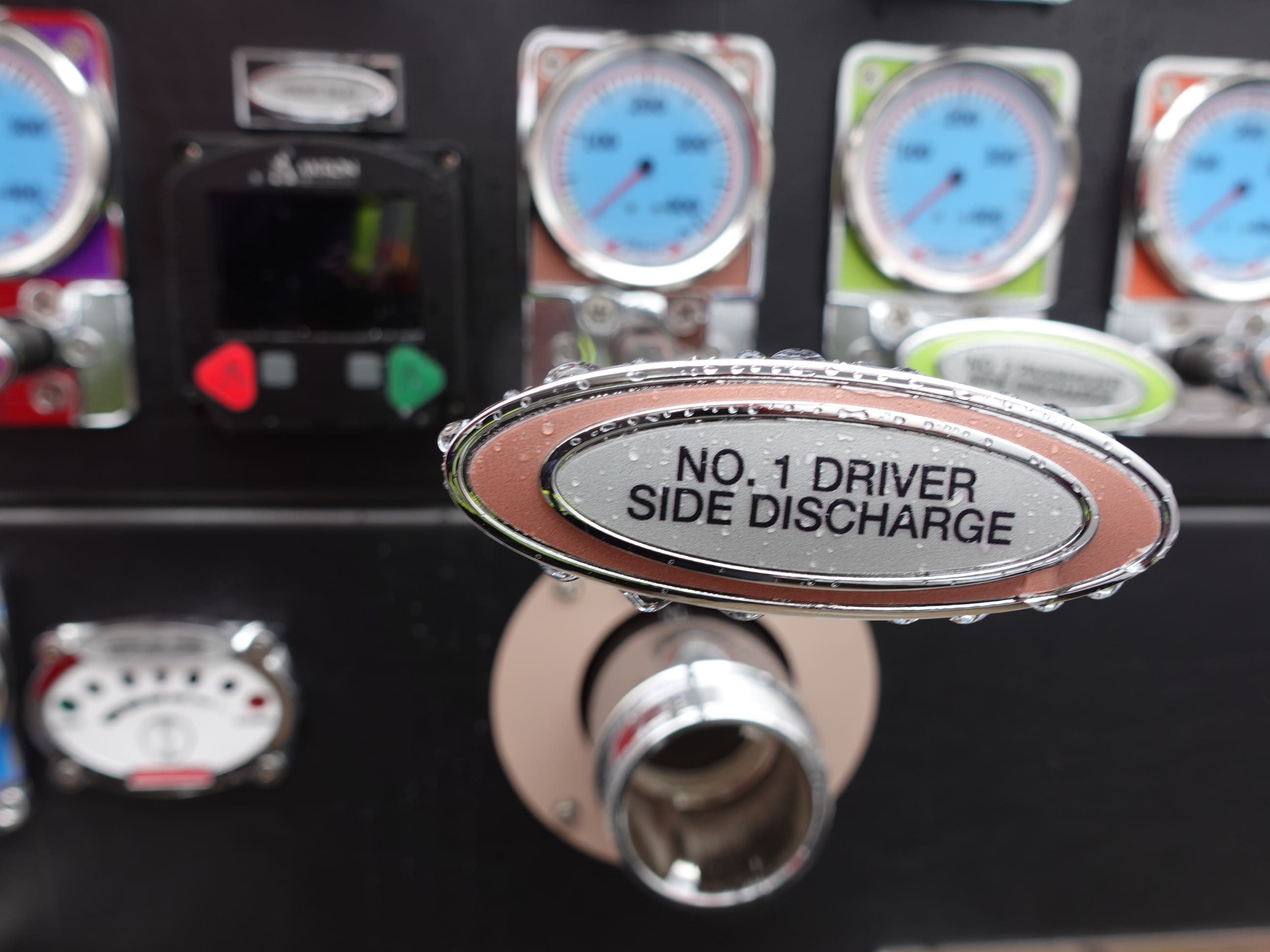

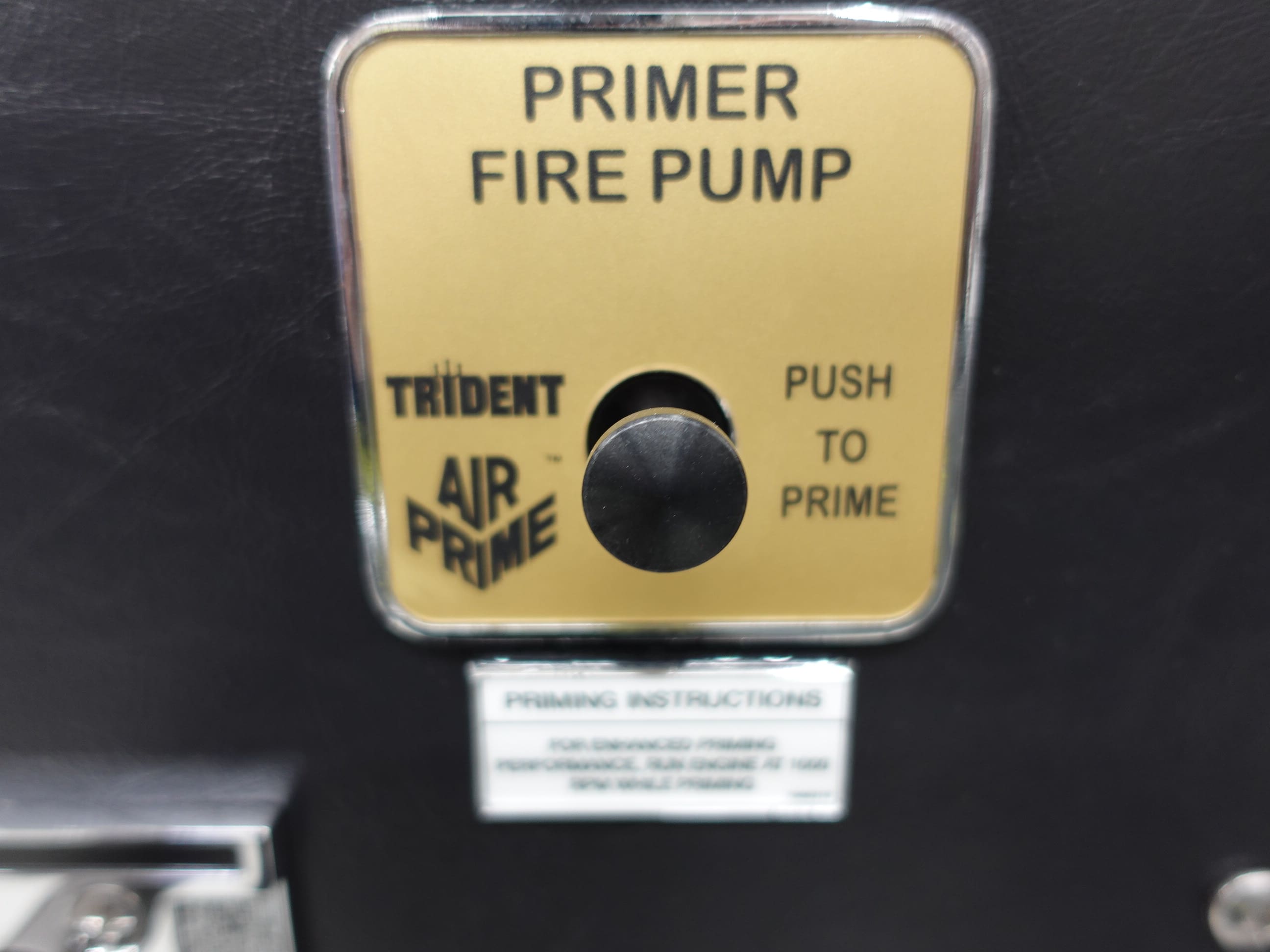

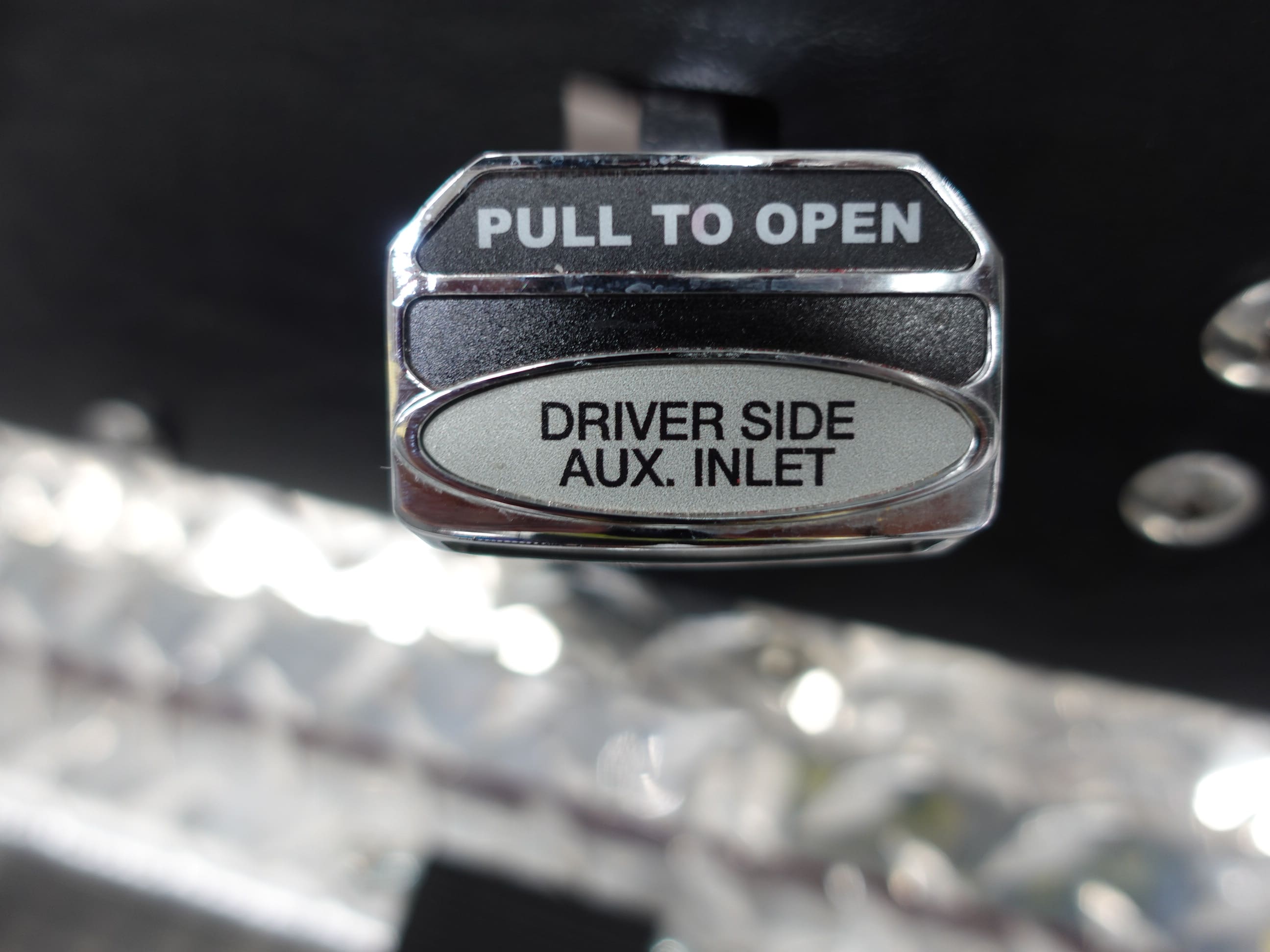

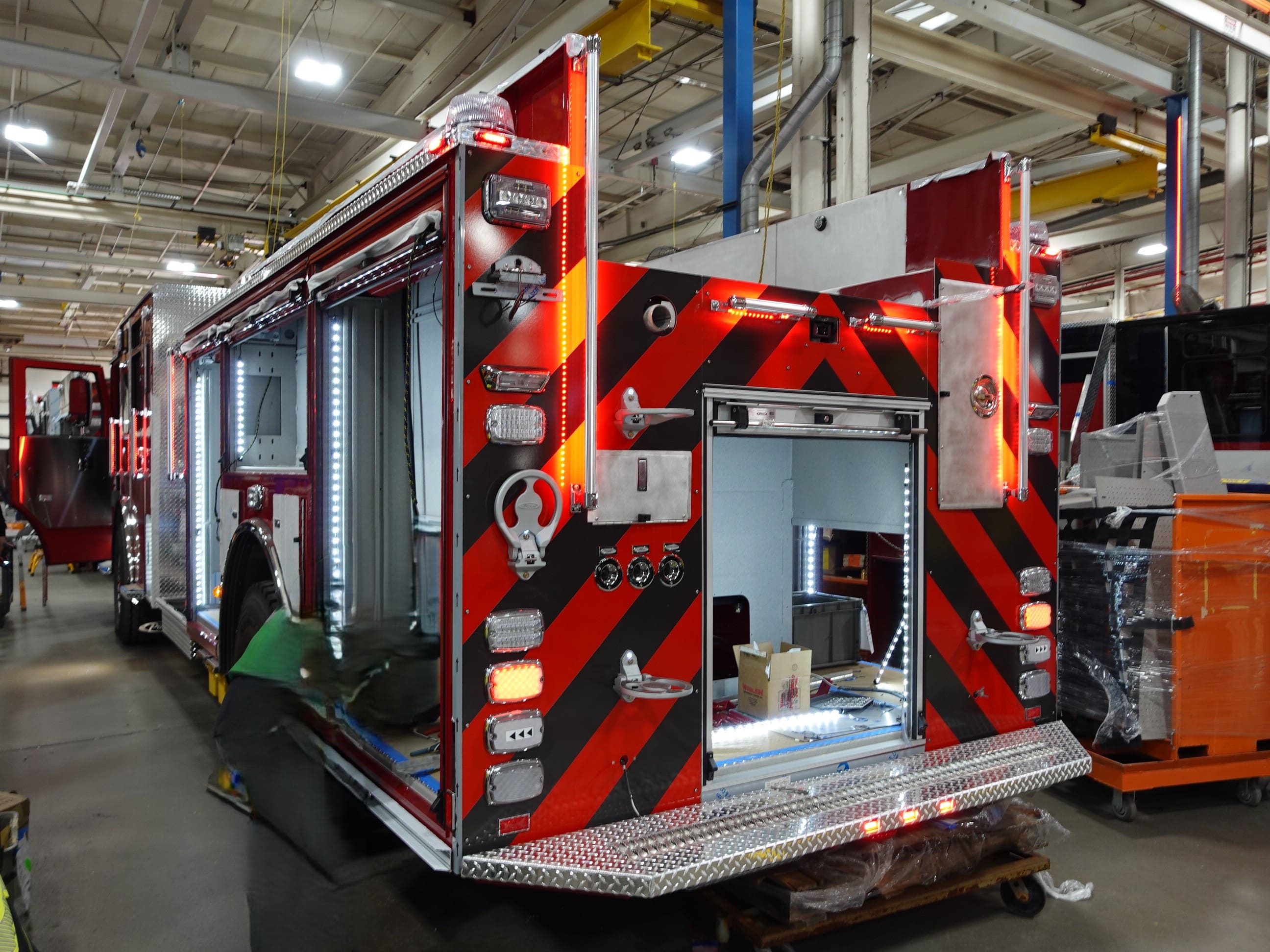

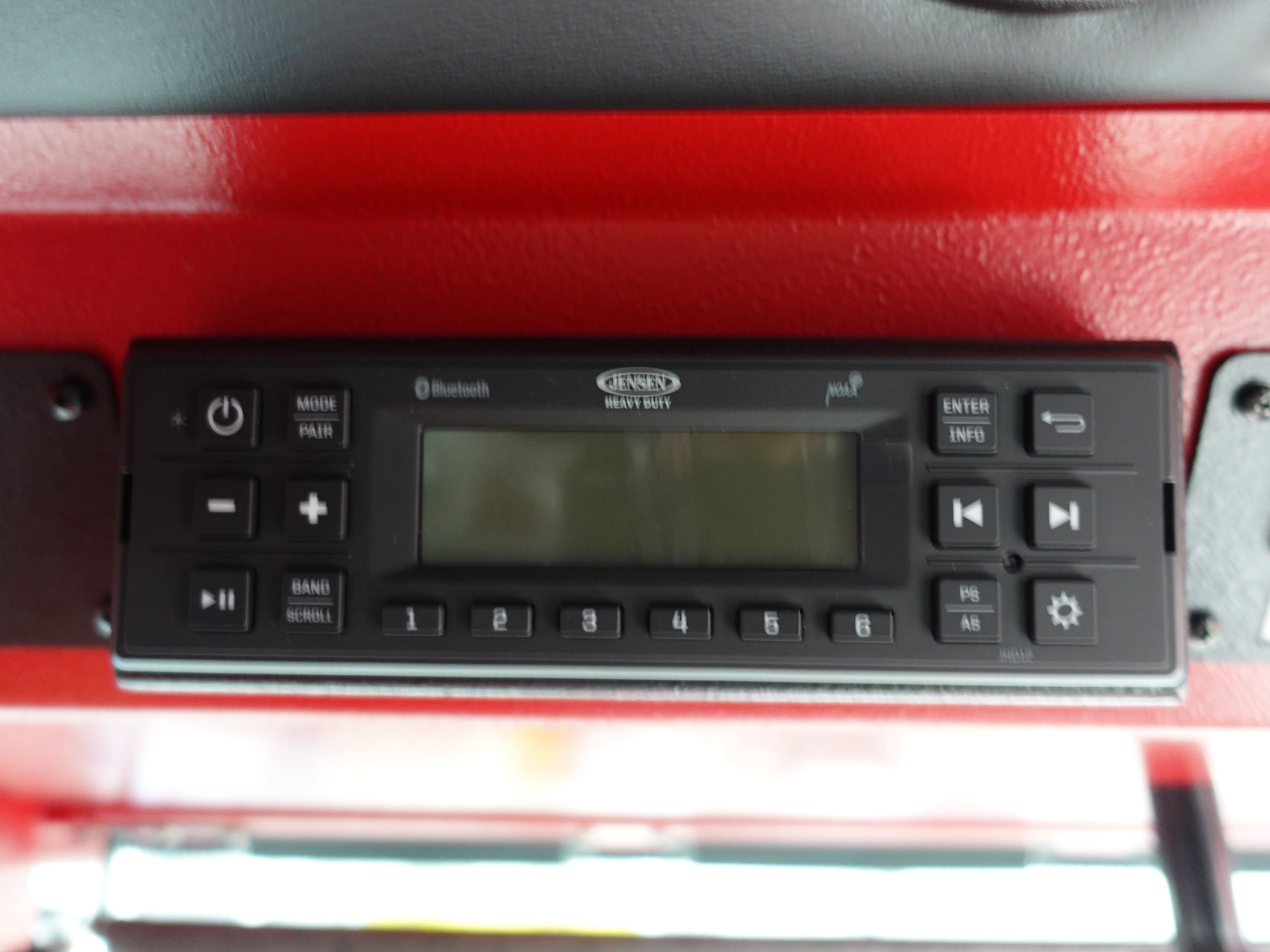

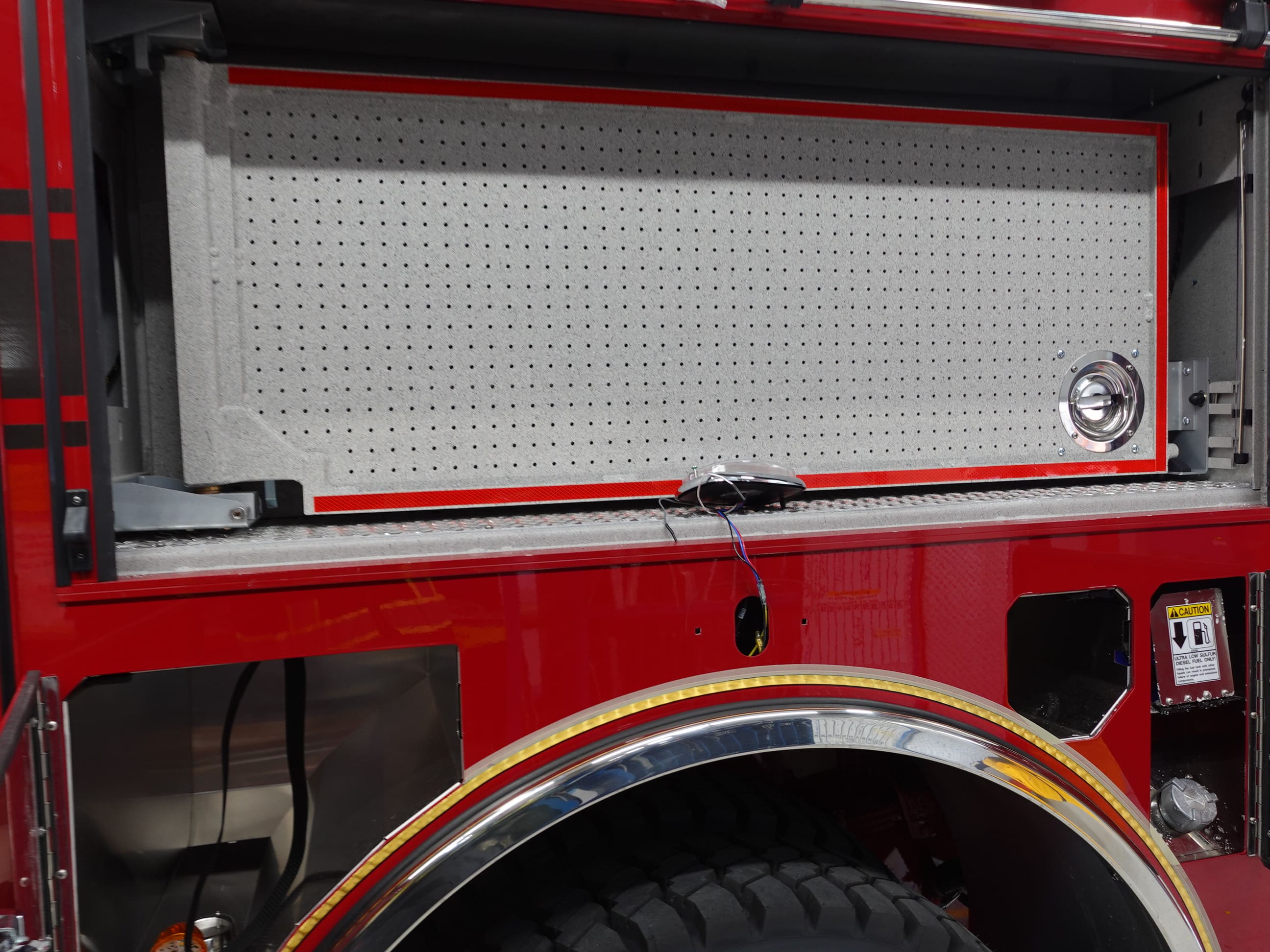

inspection. This is your last scheduled report.

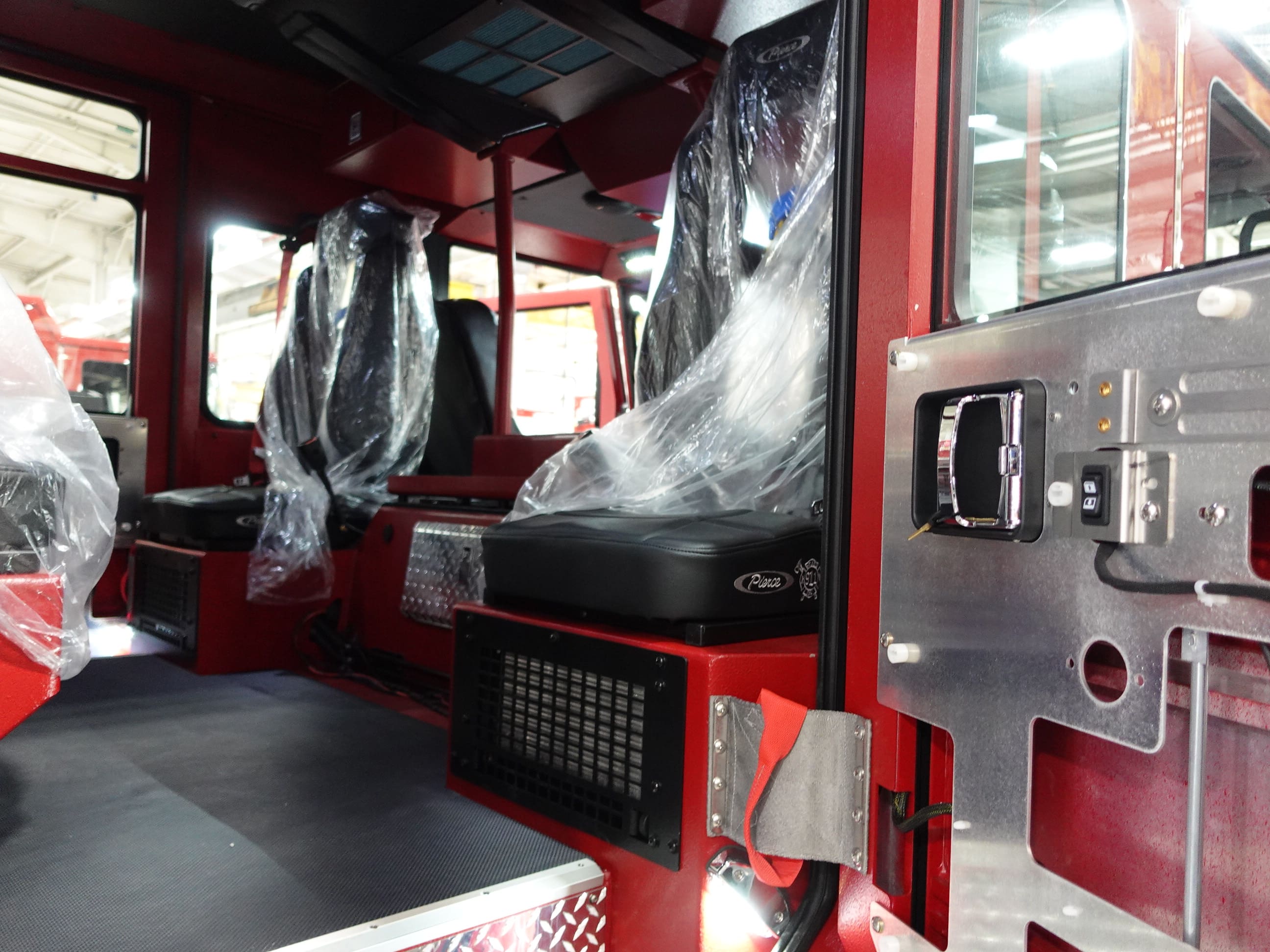

04-17-26

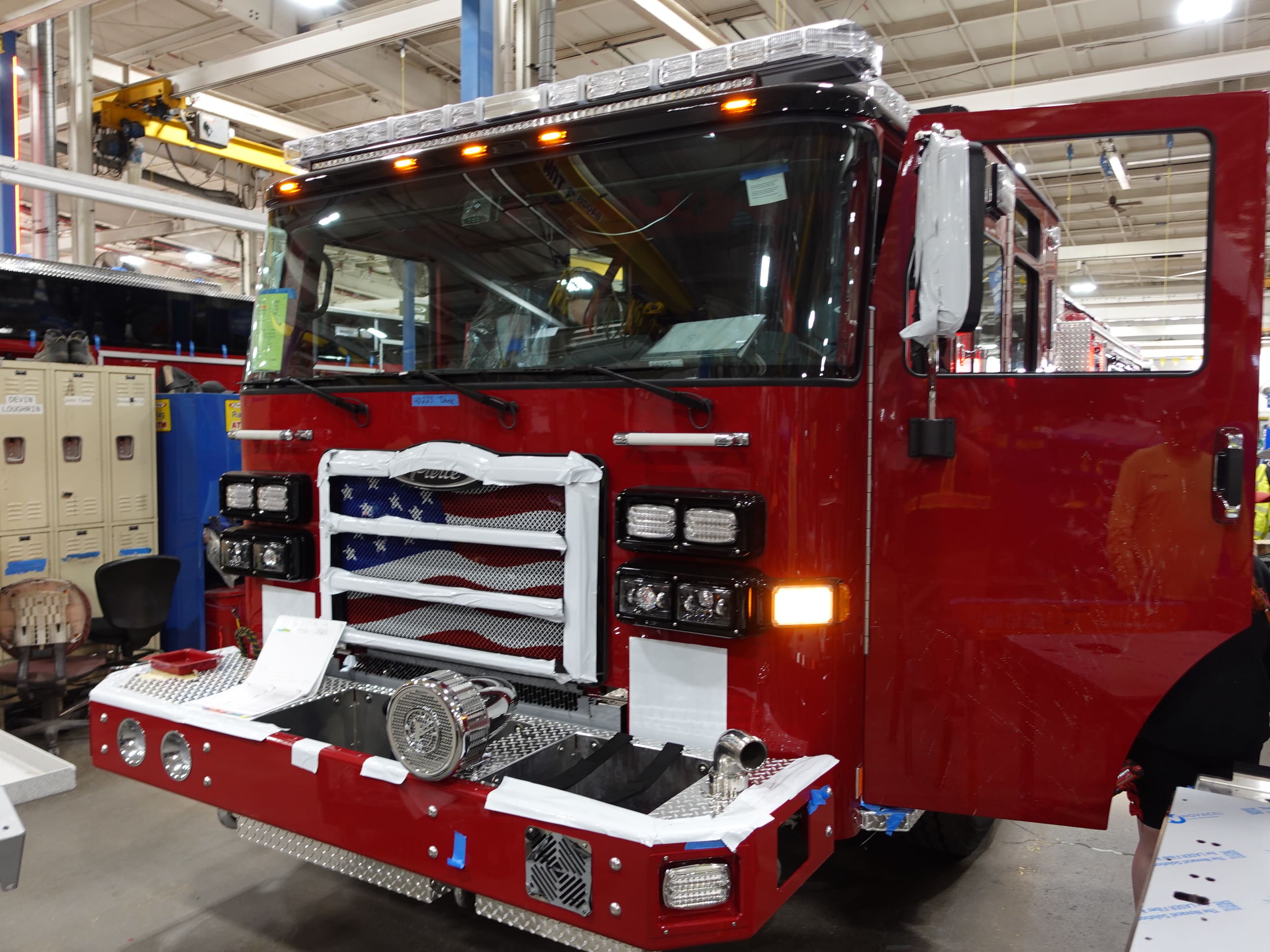

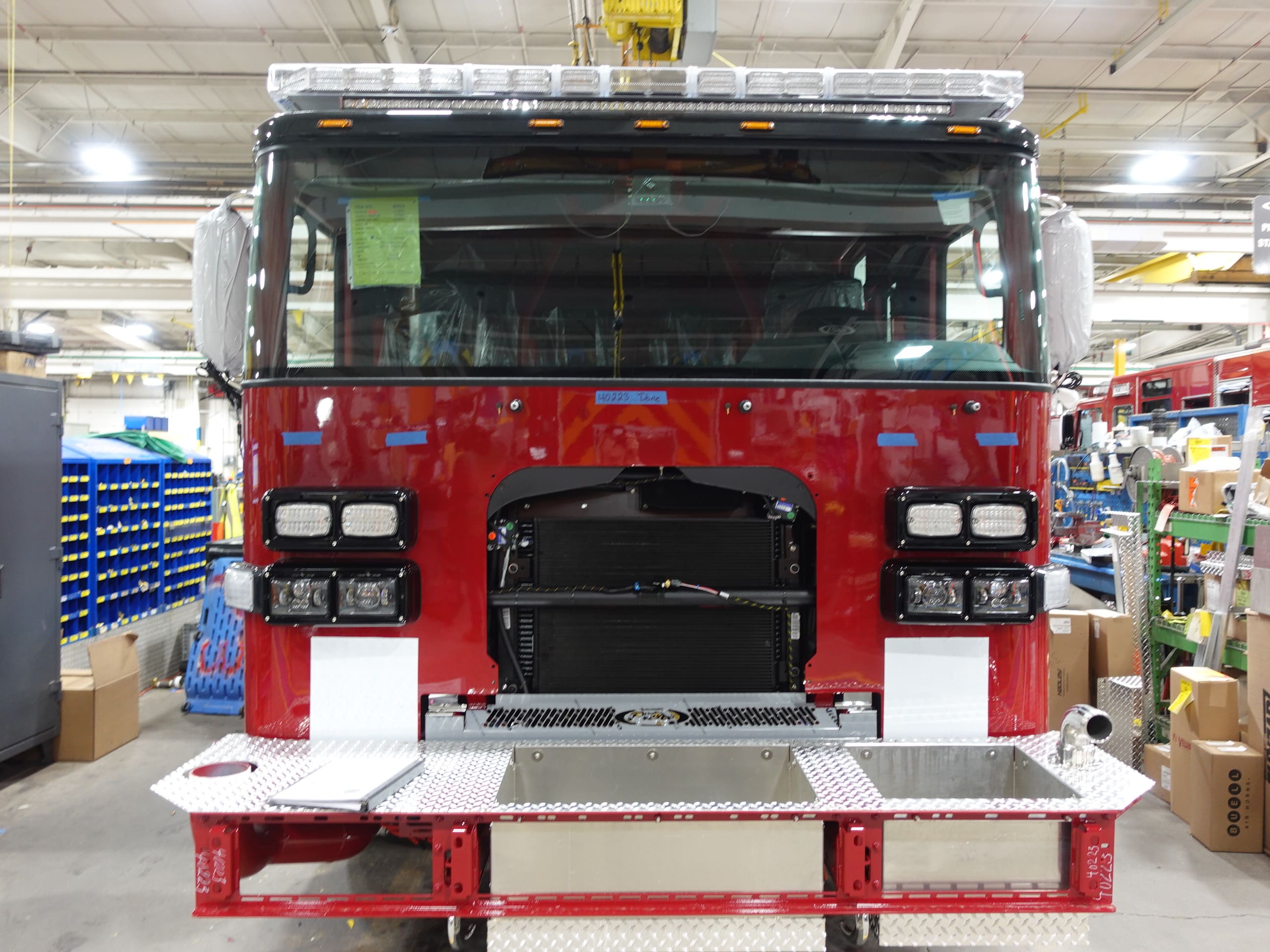

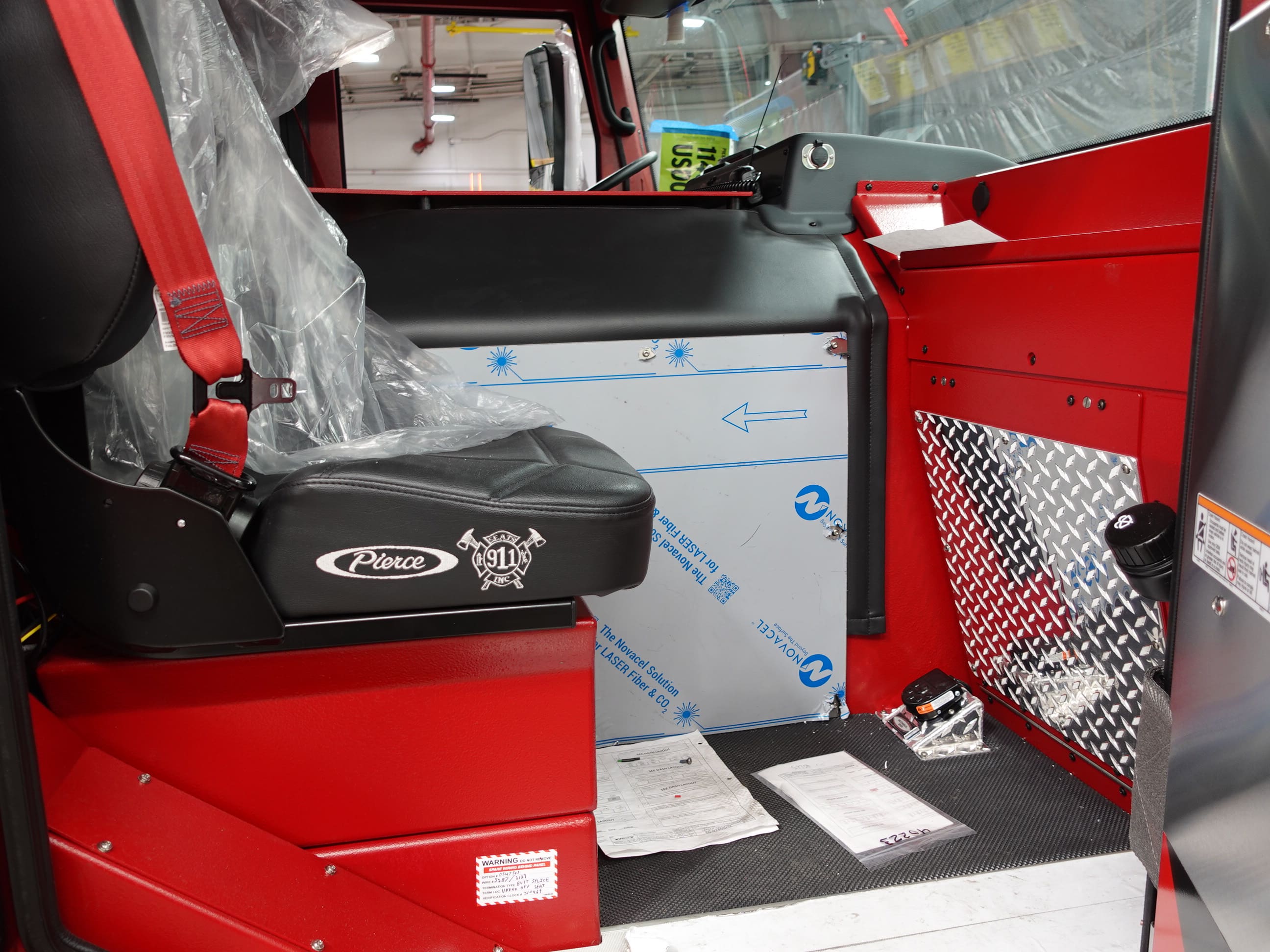

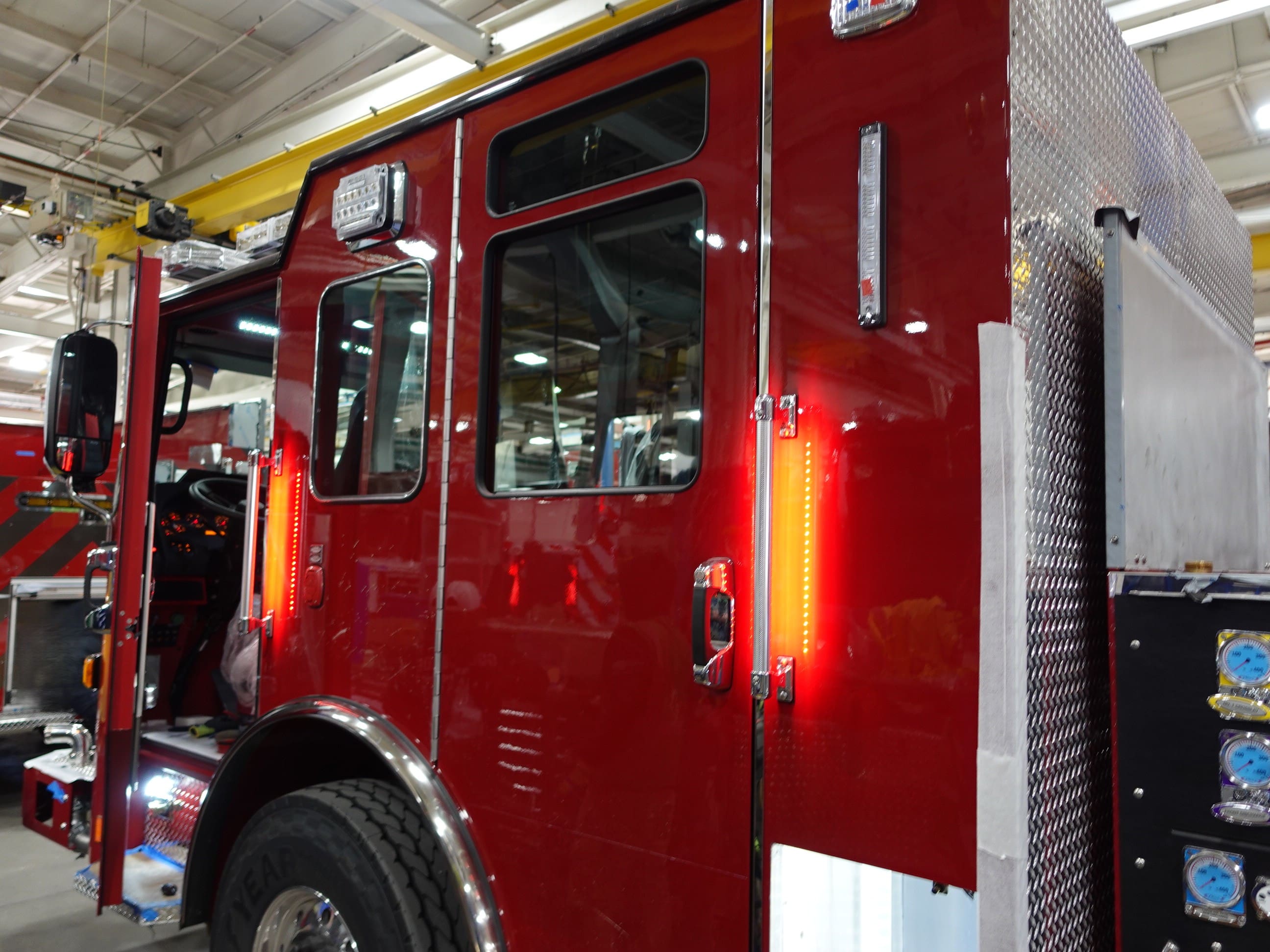

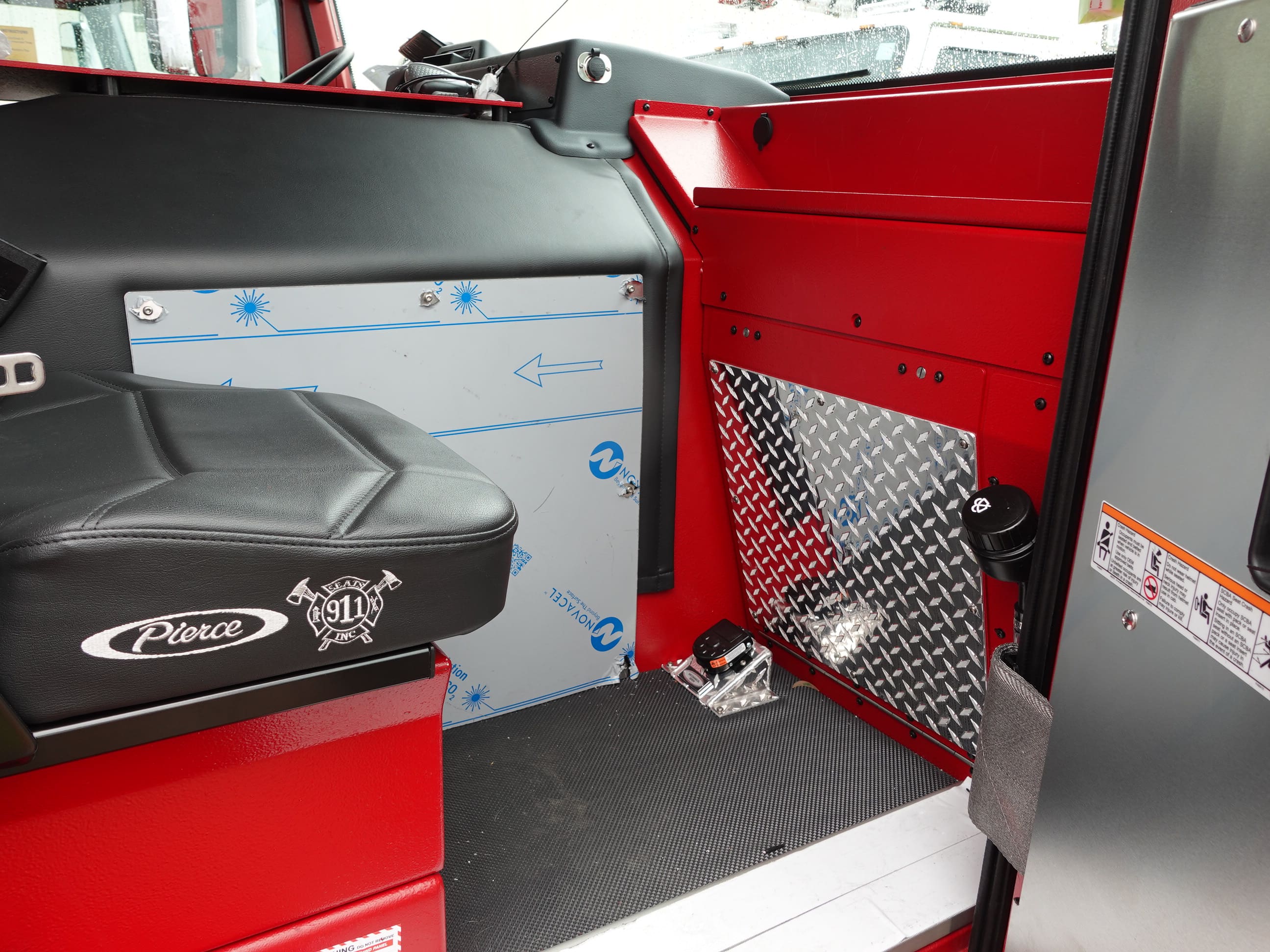

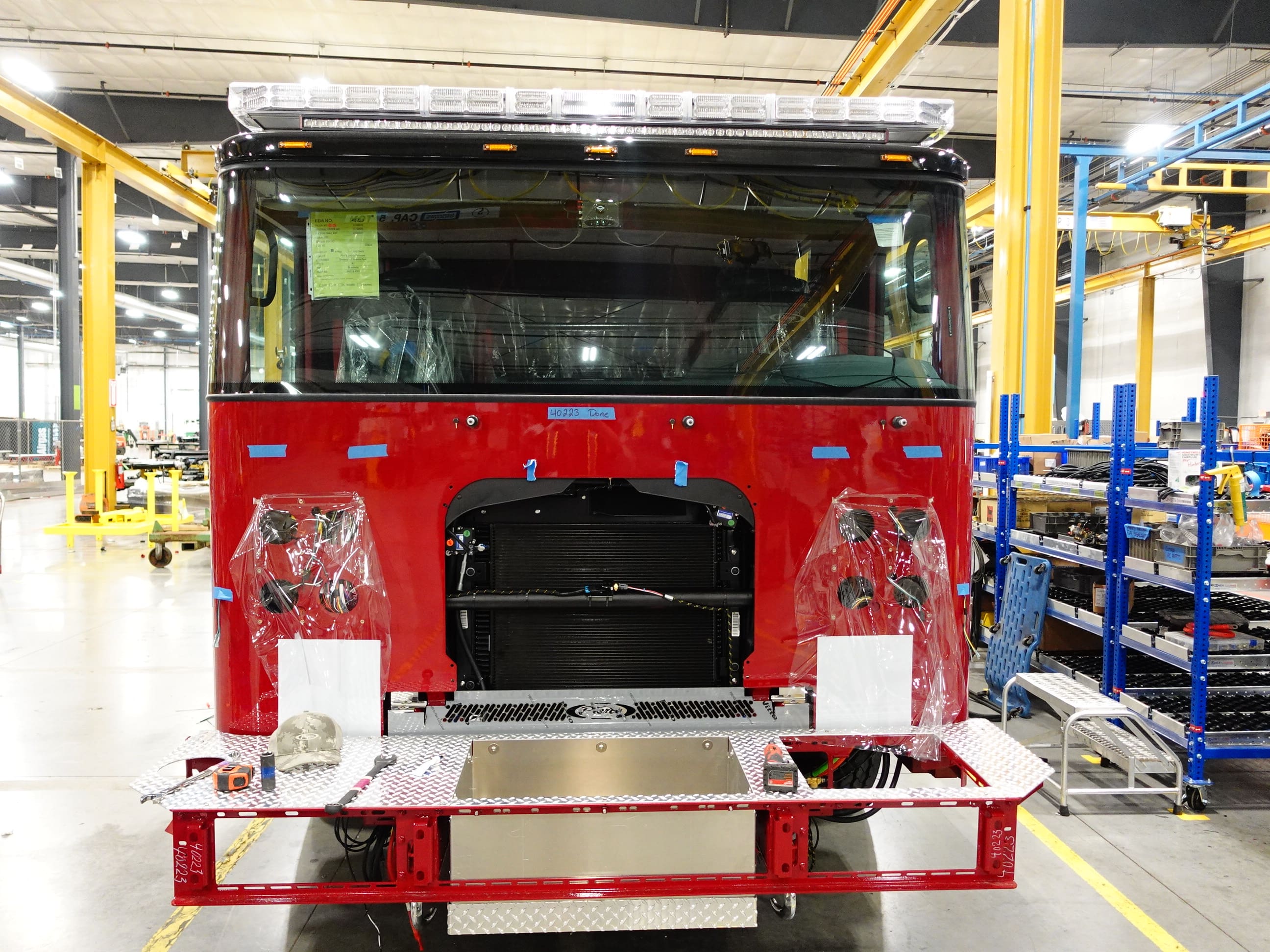

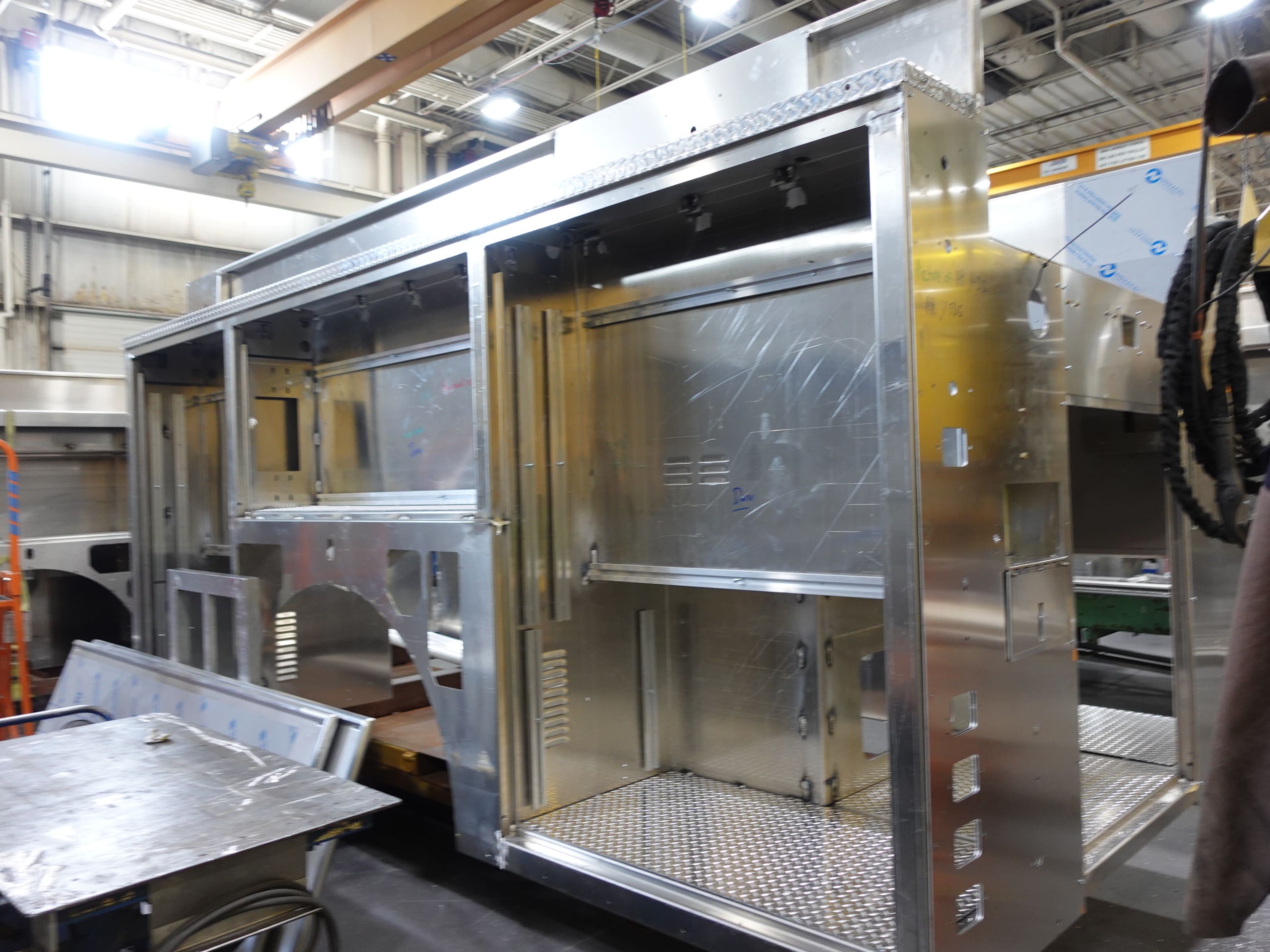

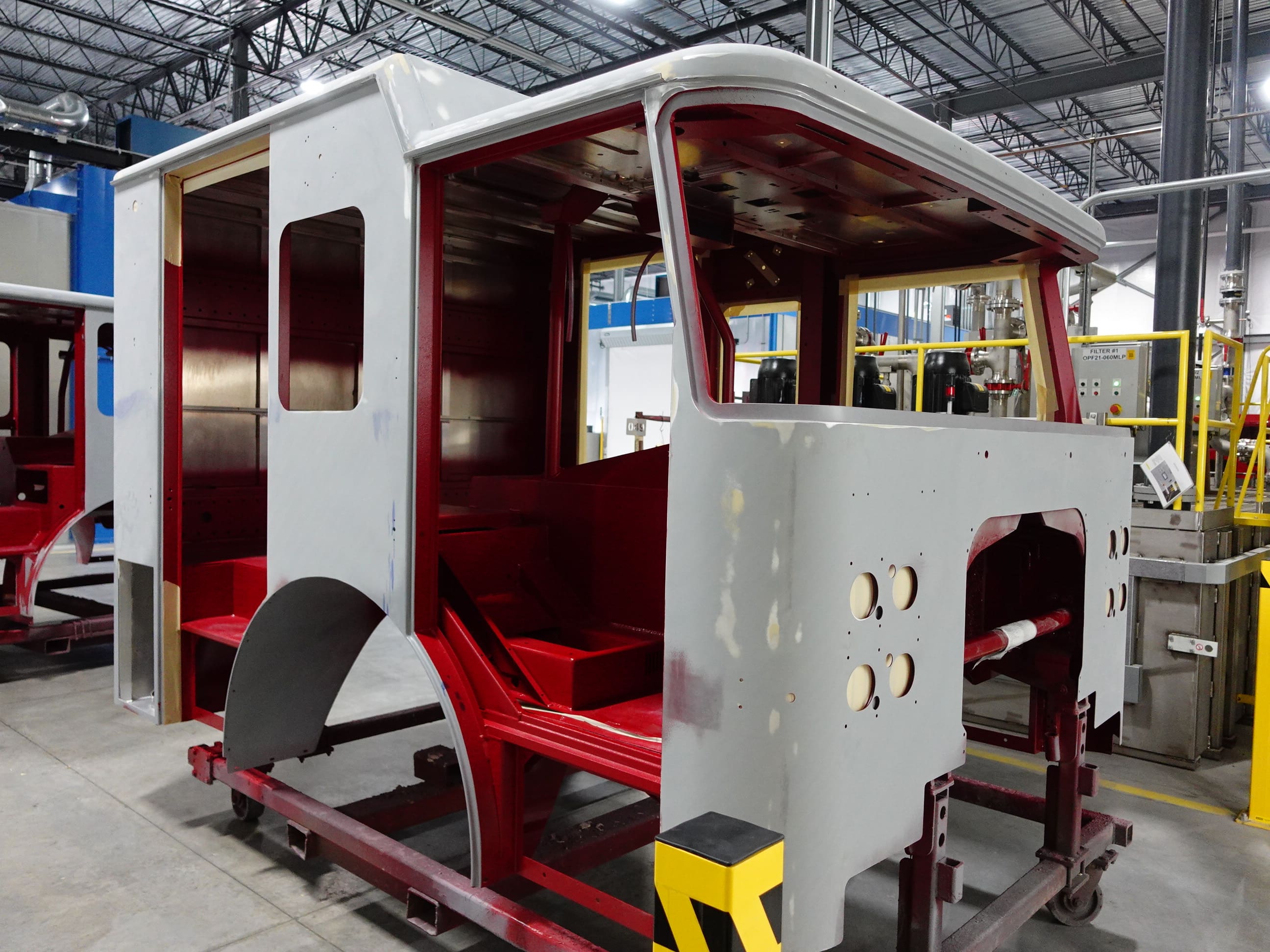

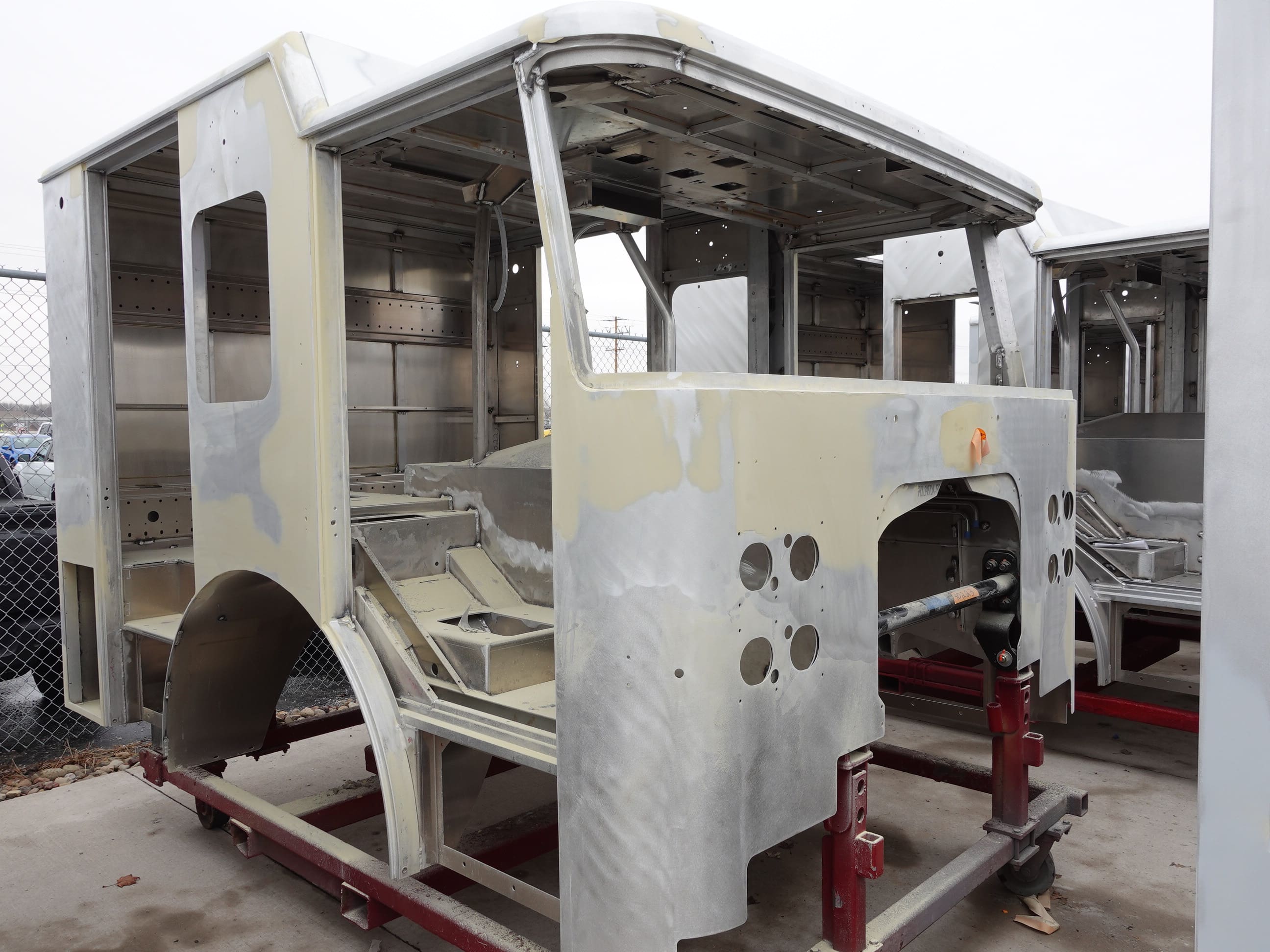

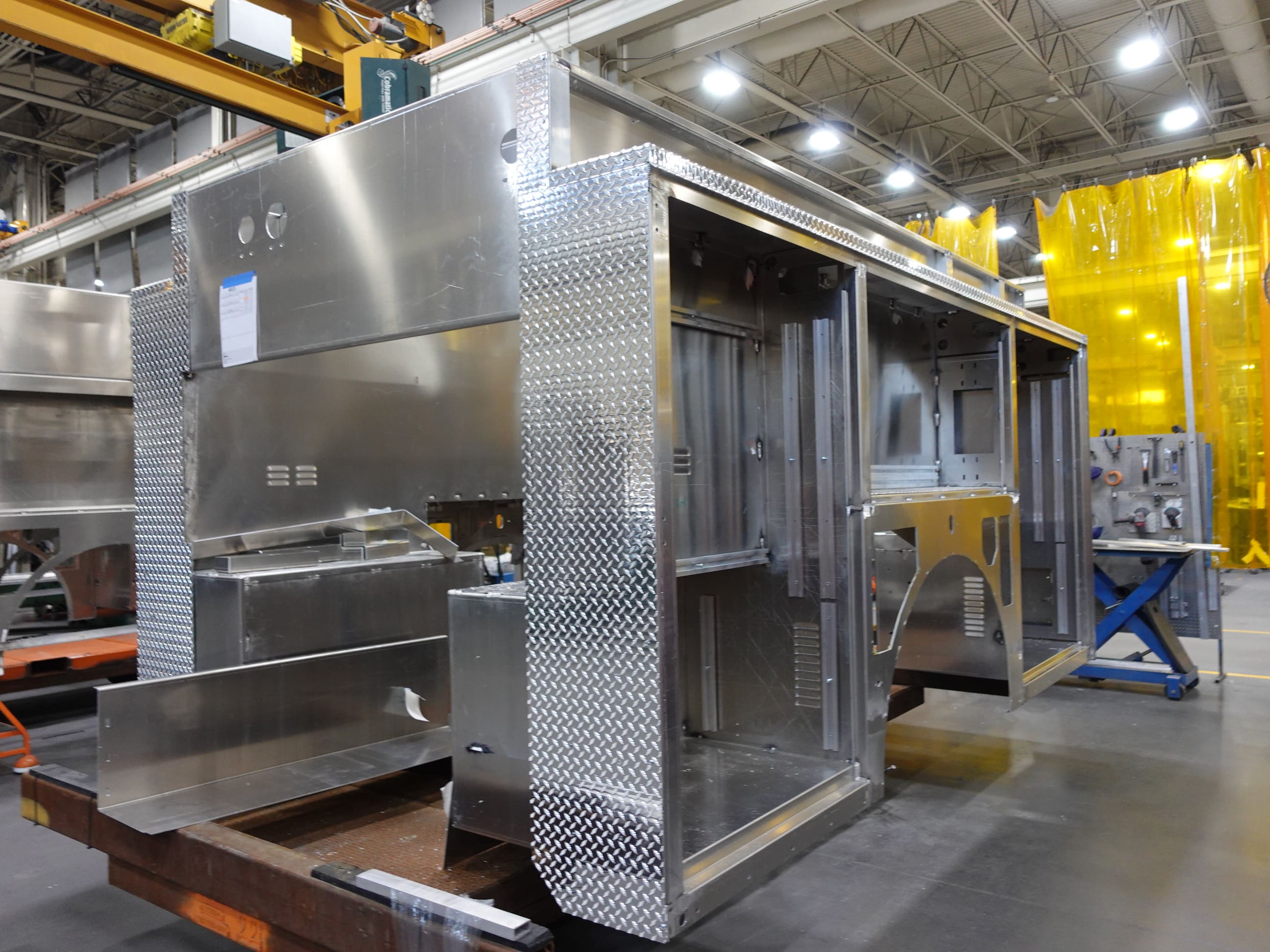

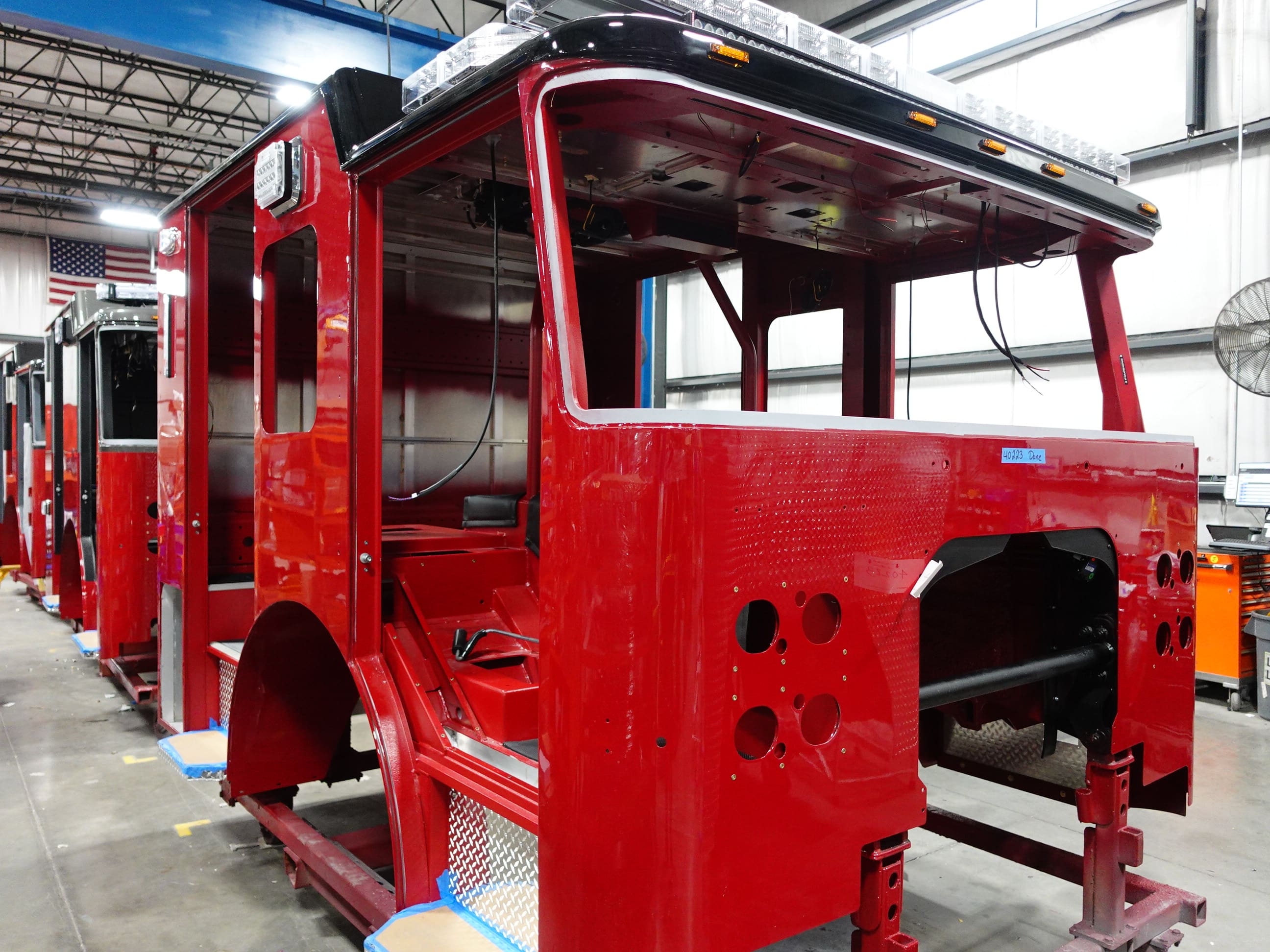

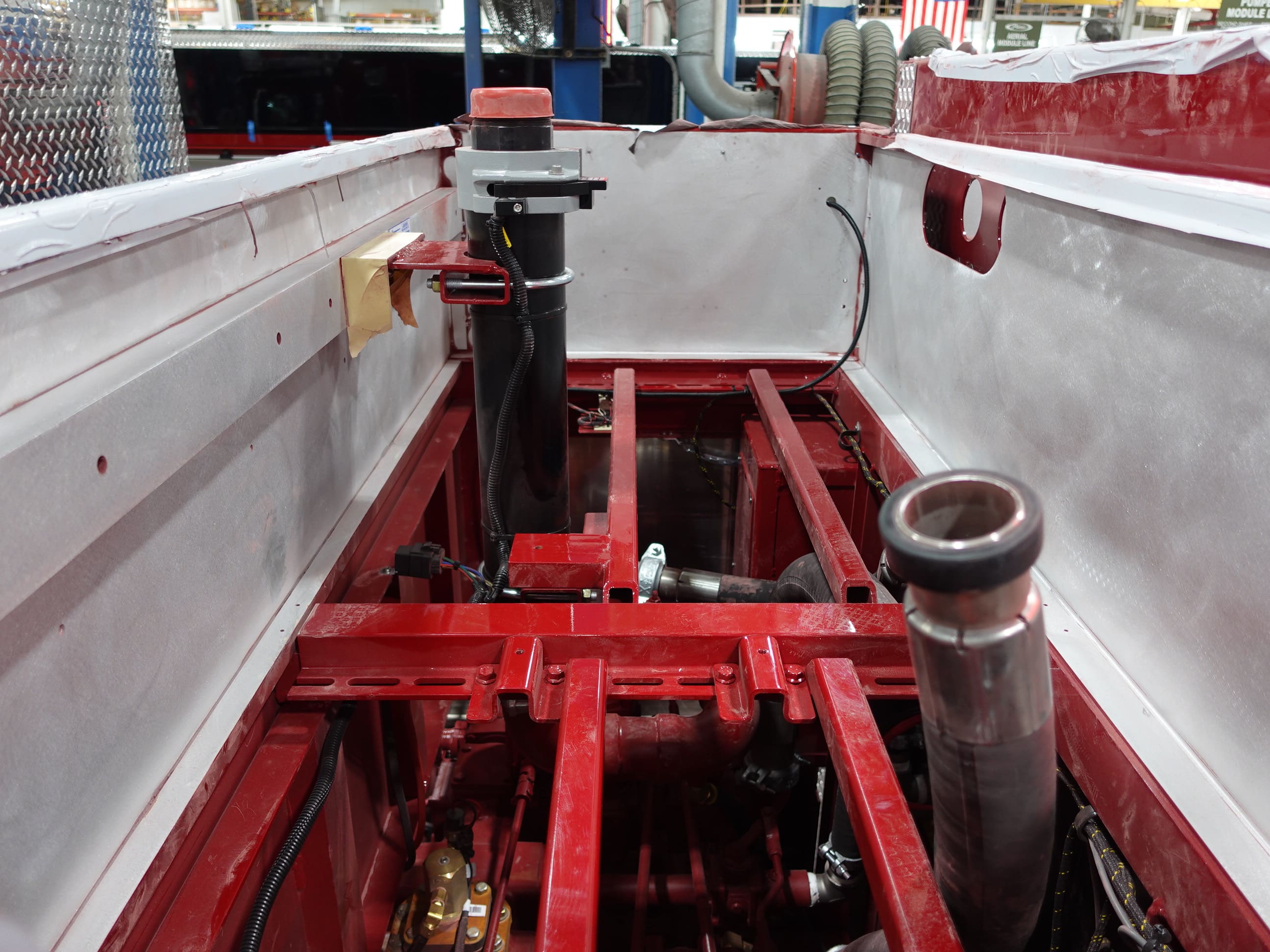

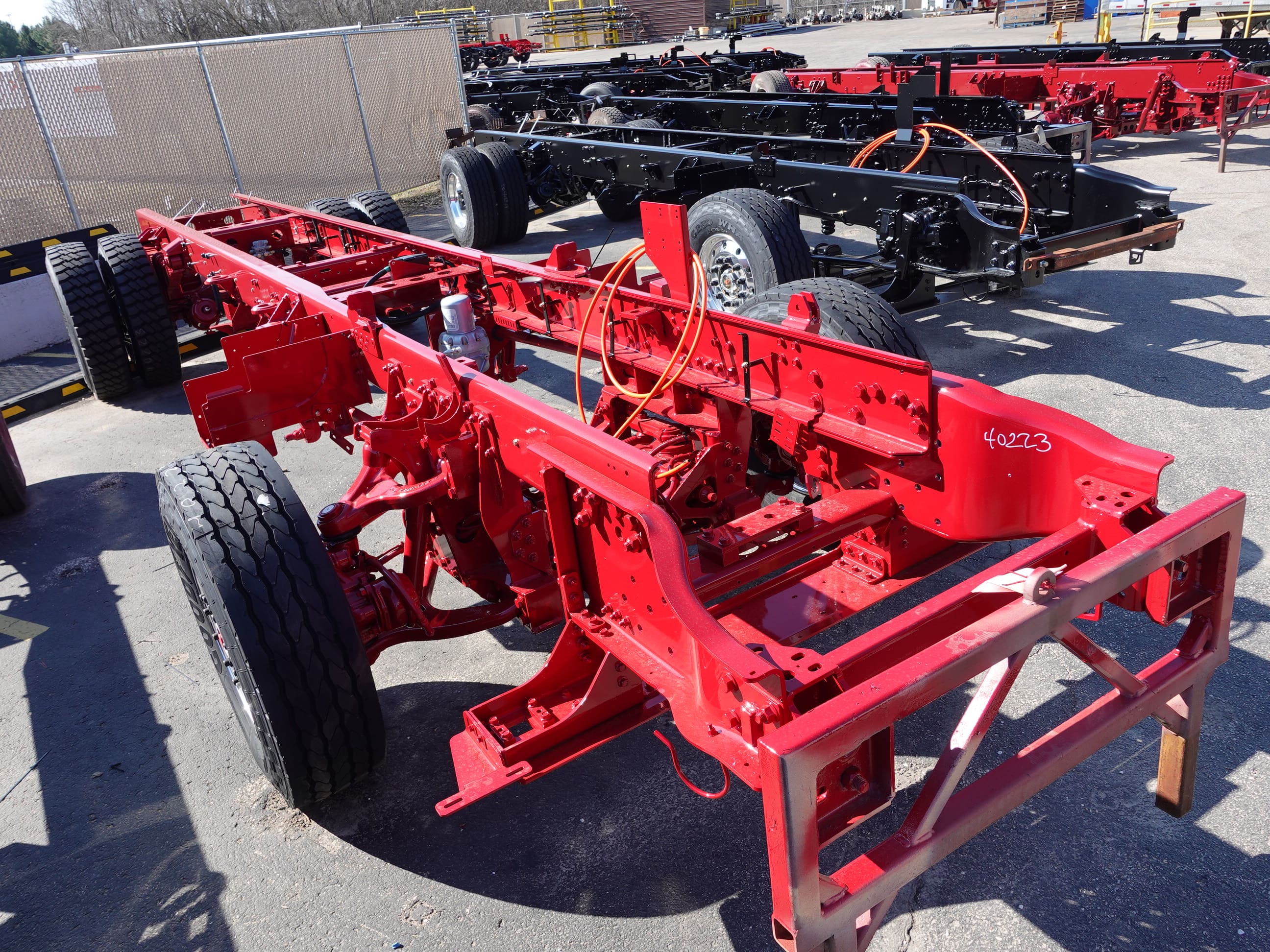

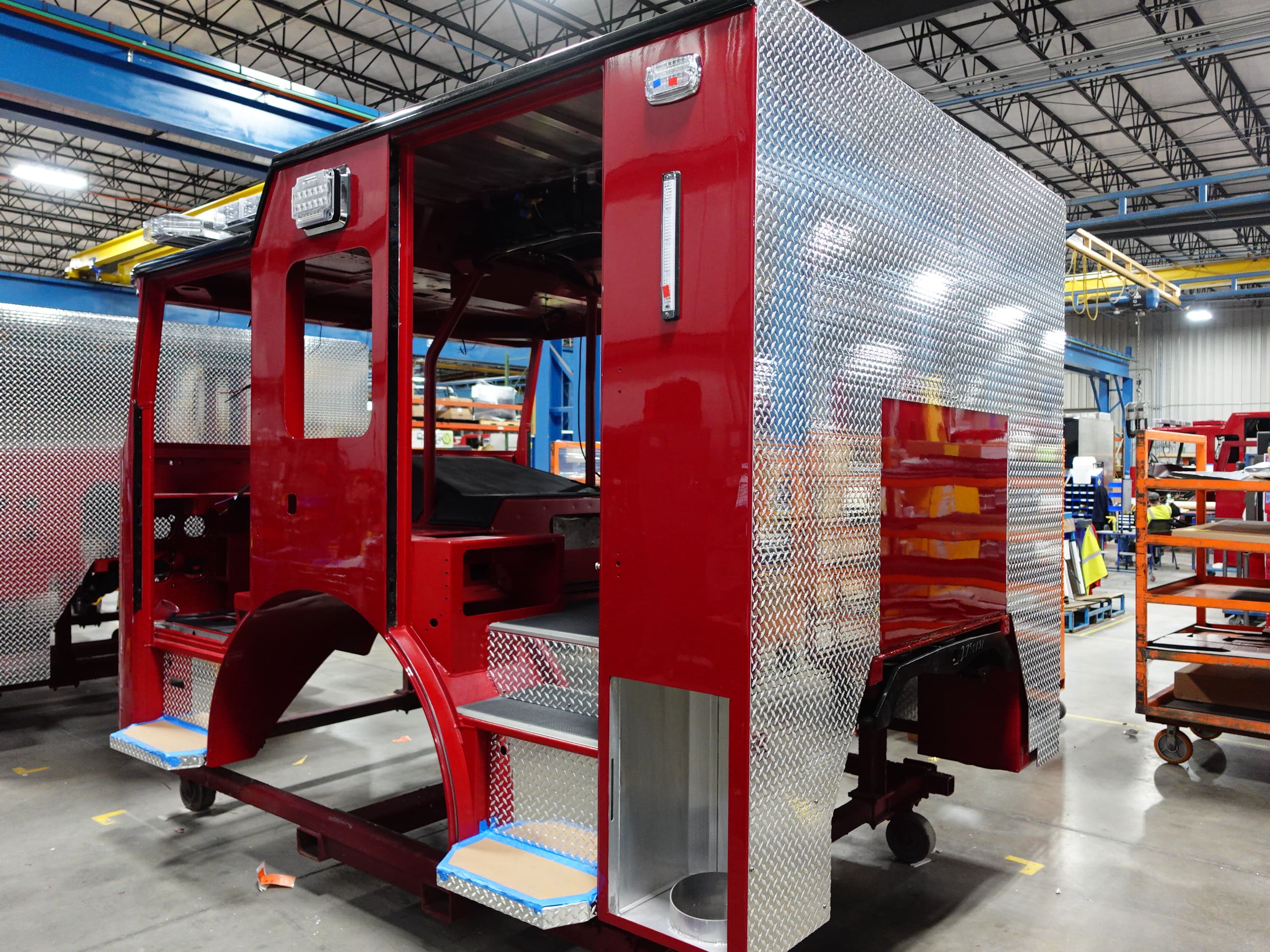

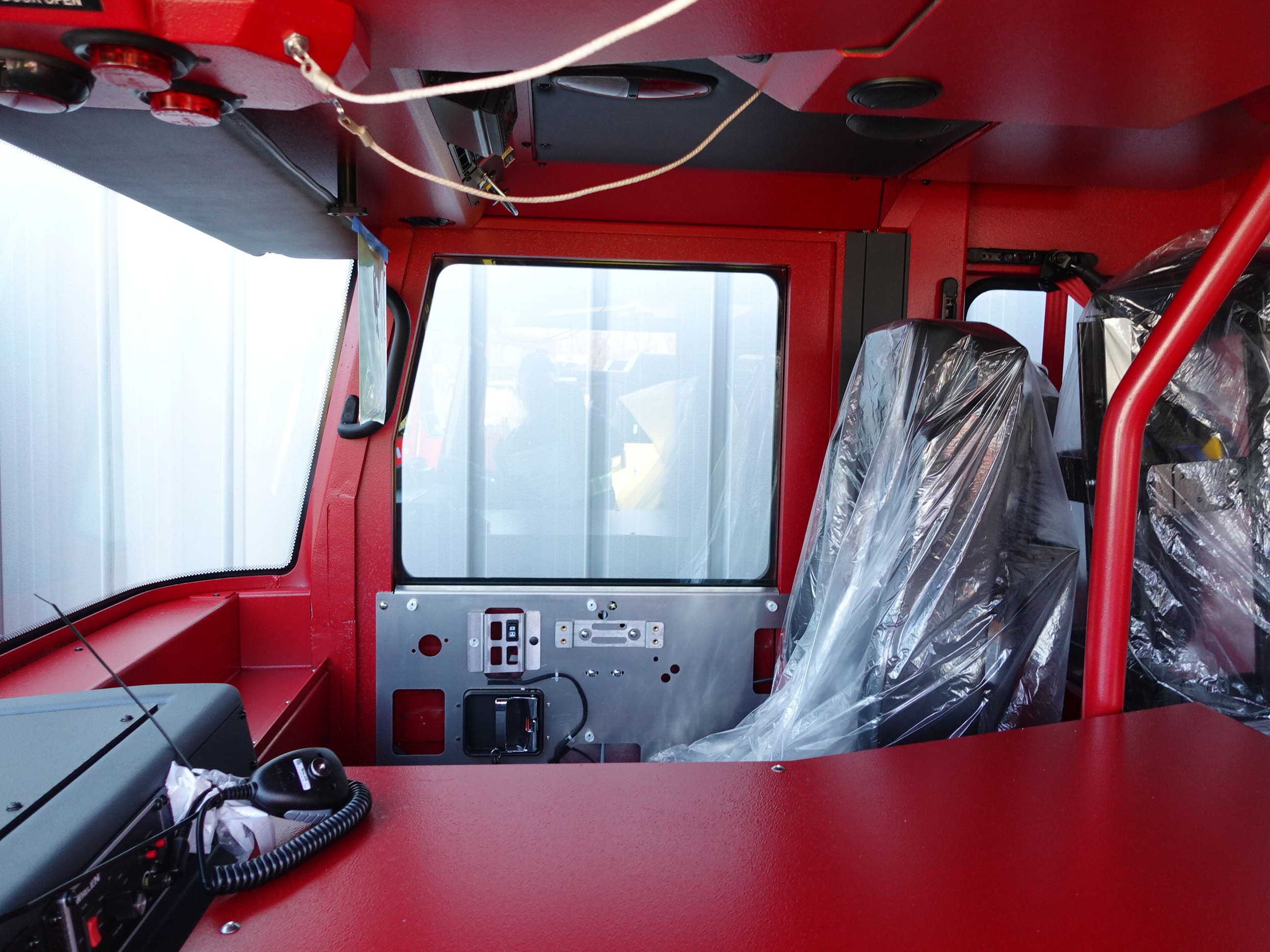

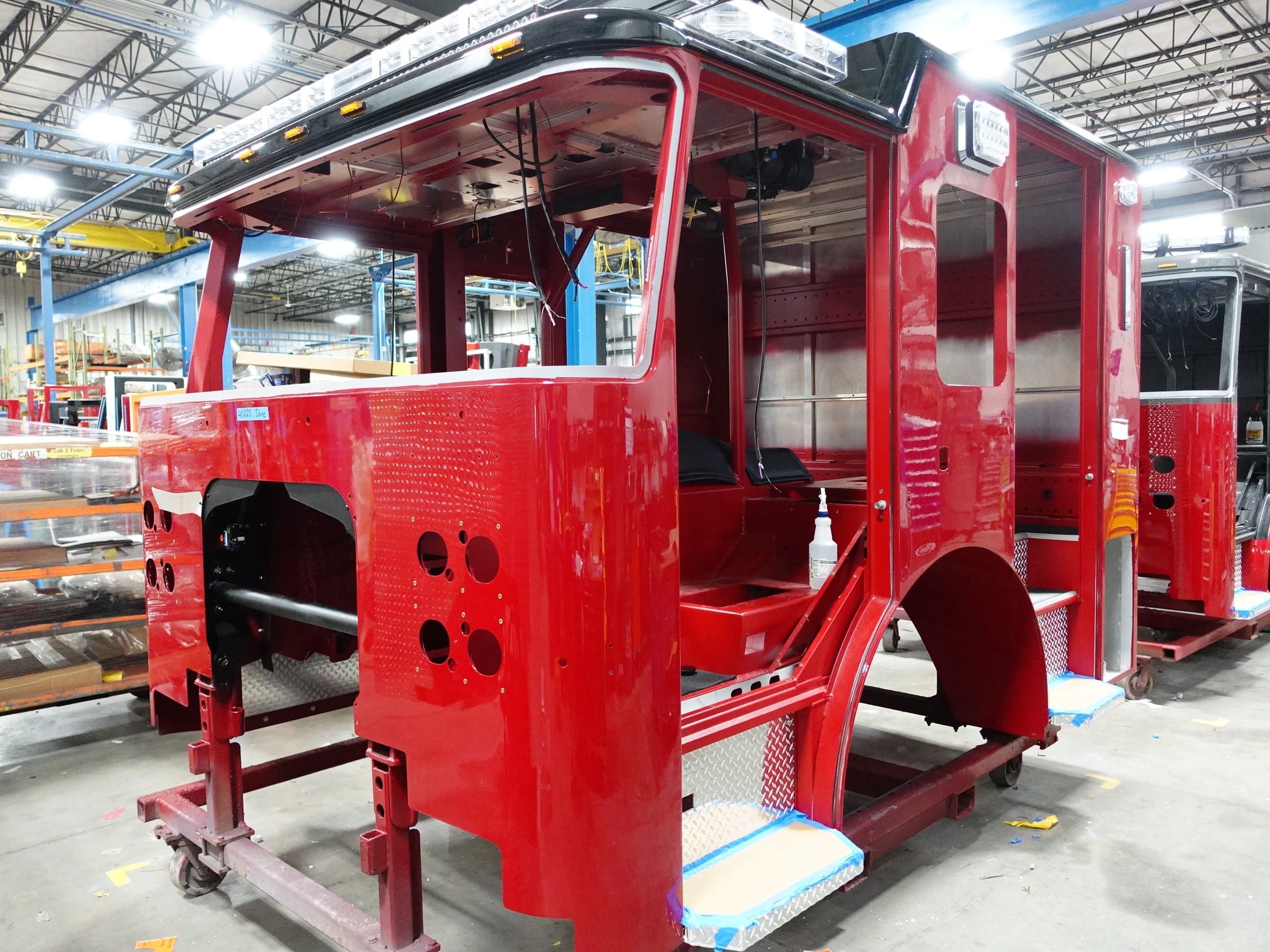

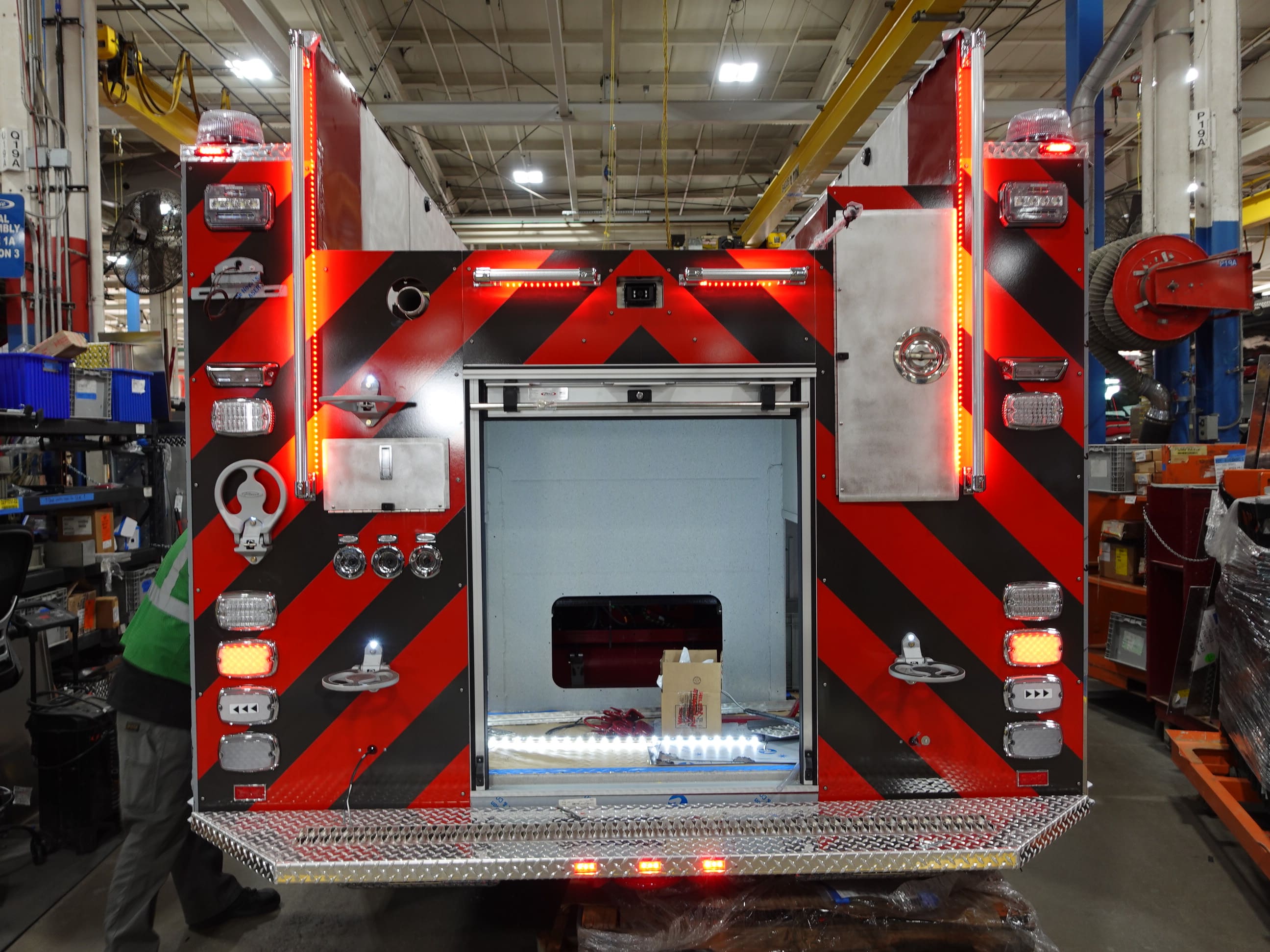

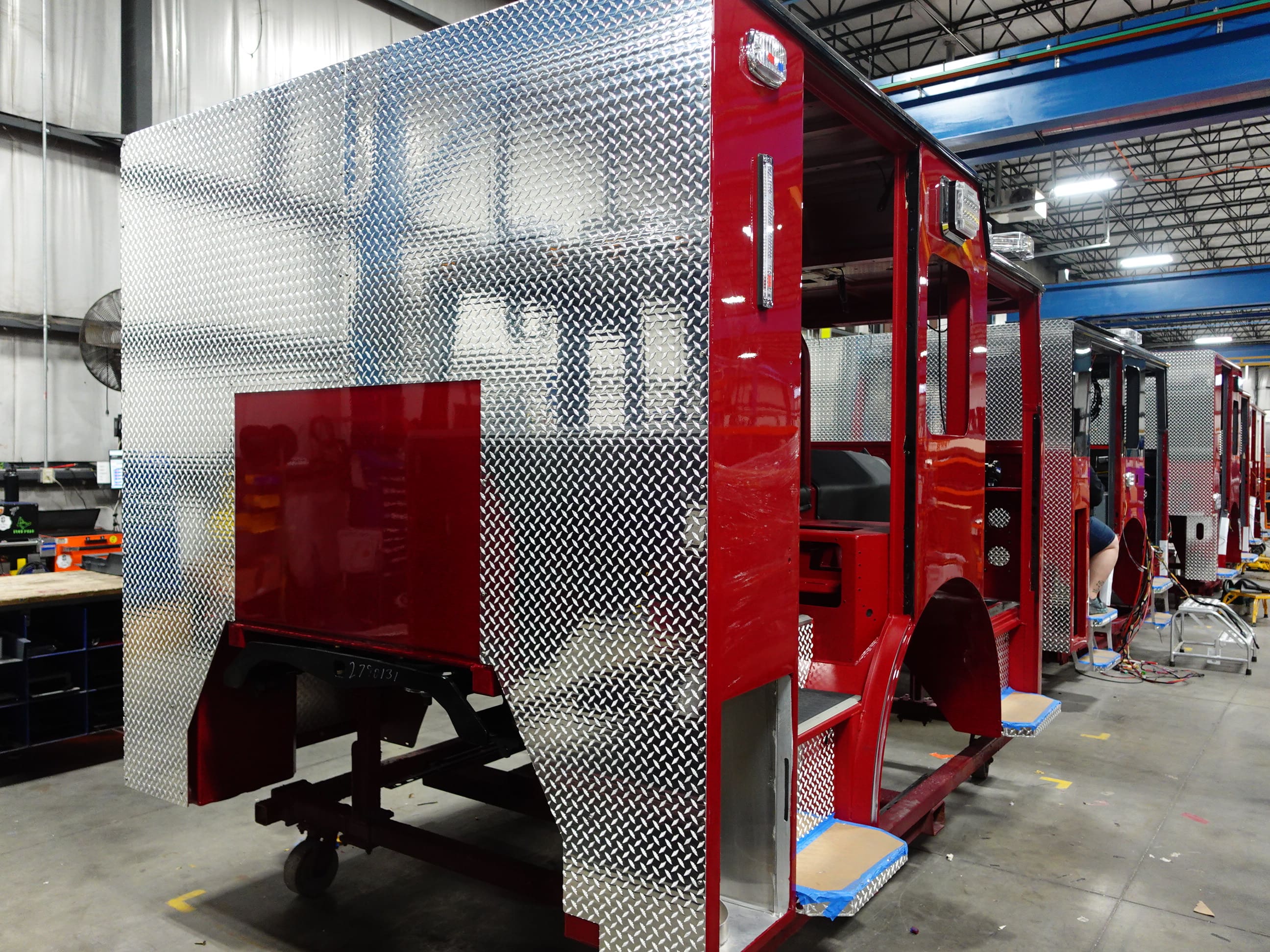

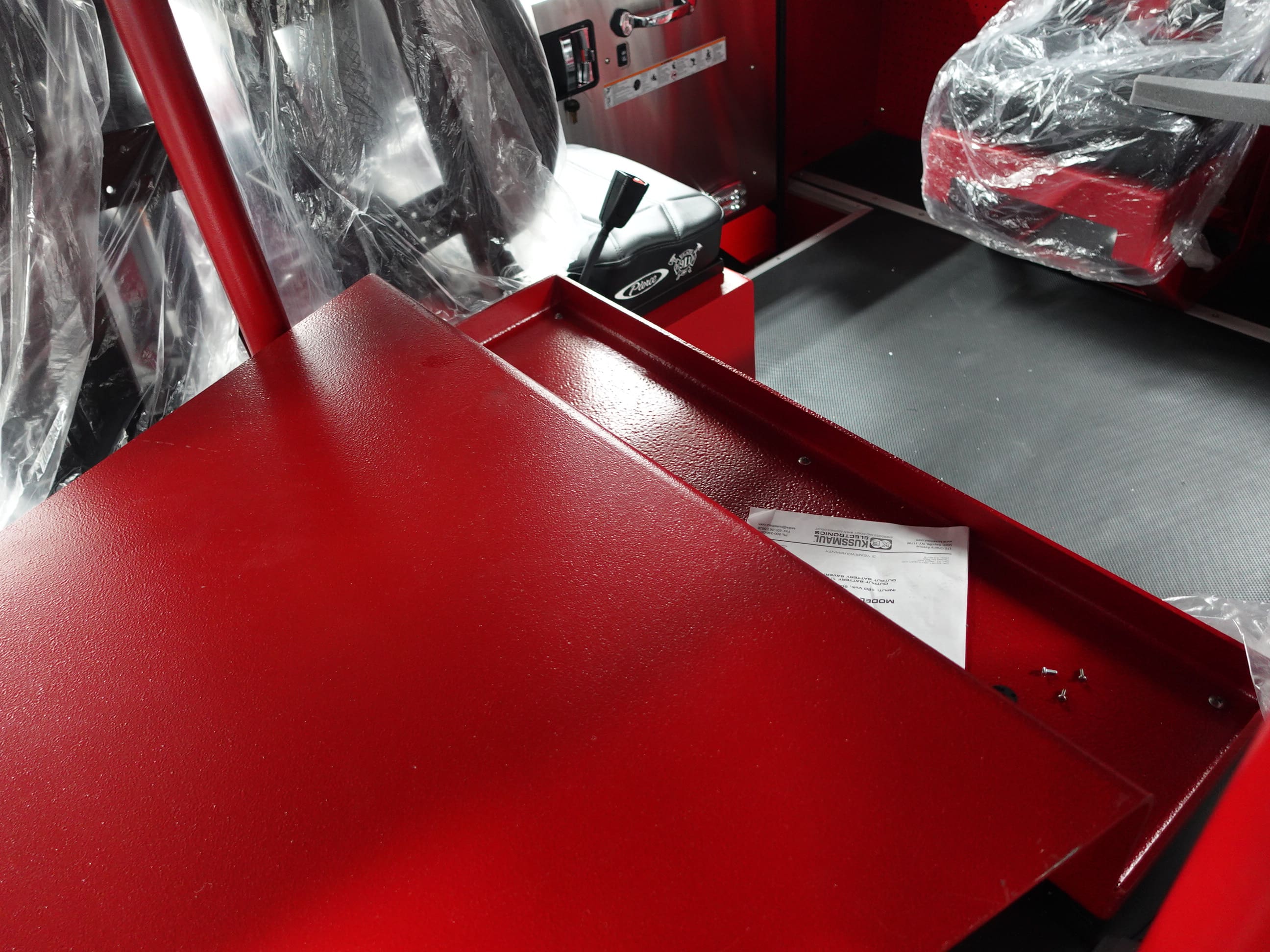

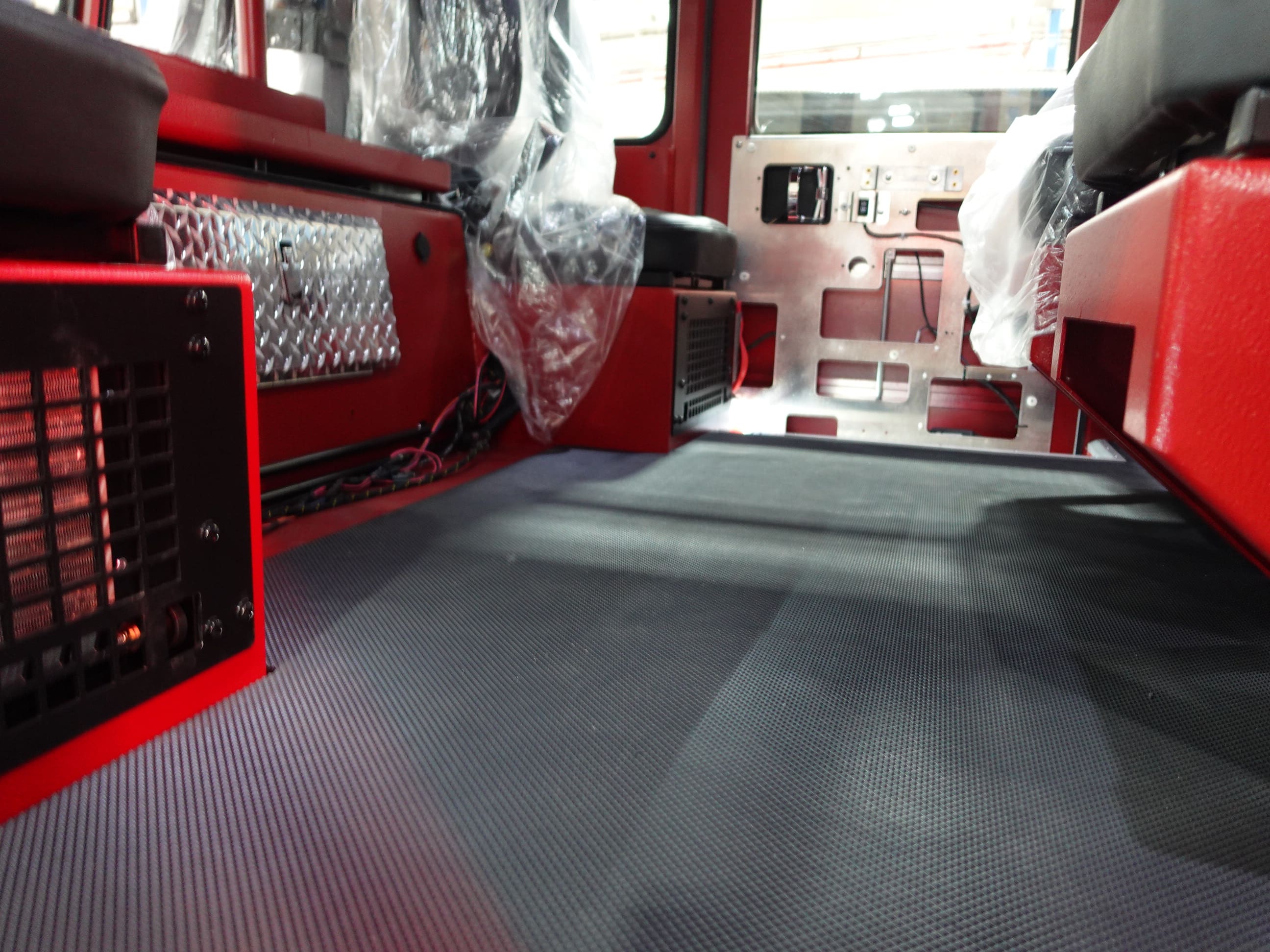

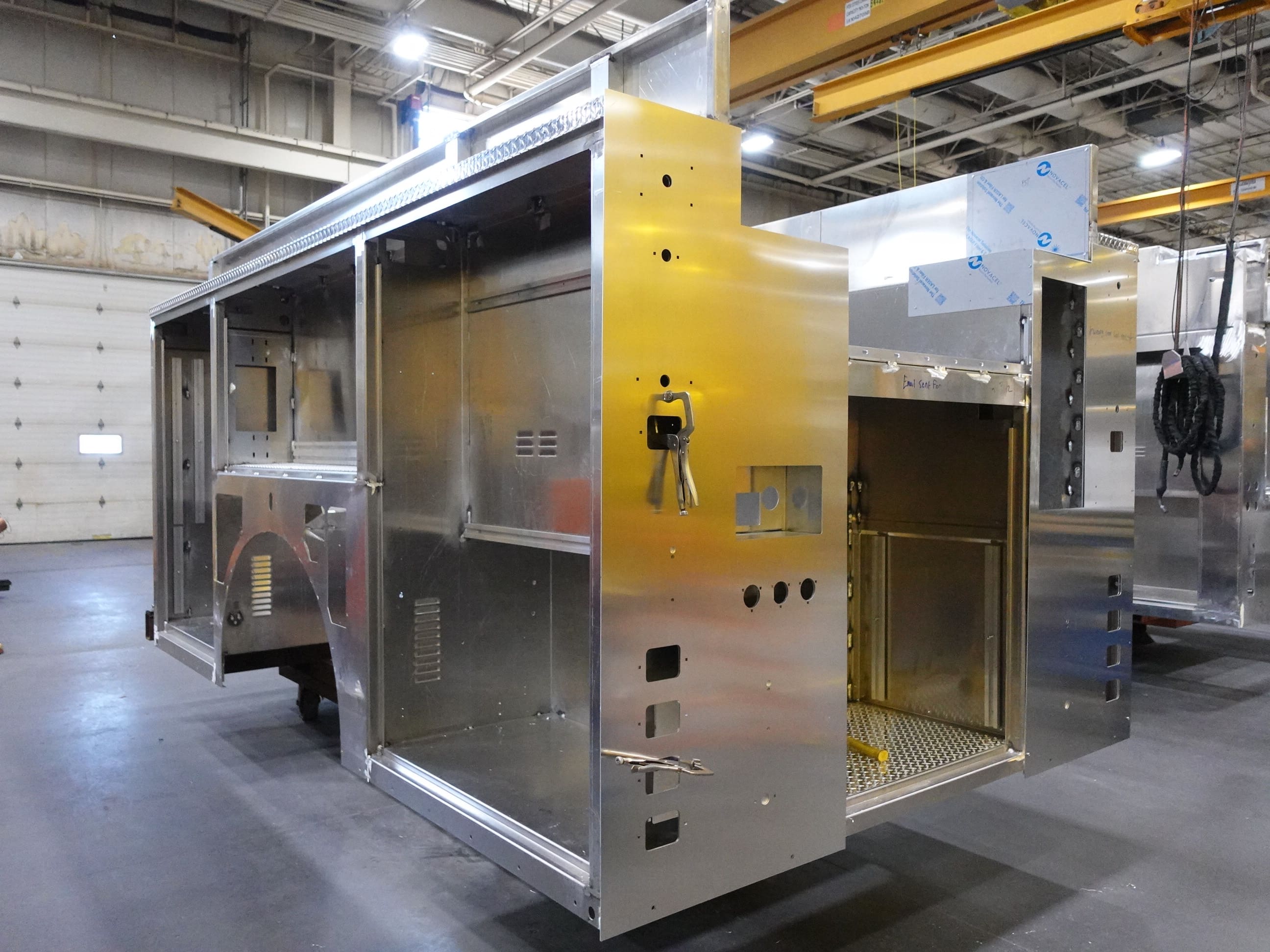

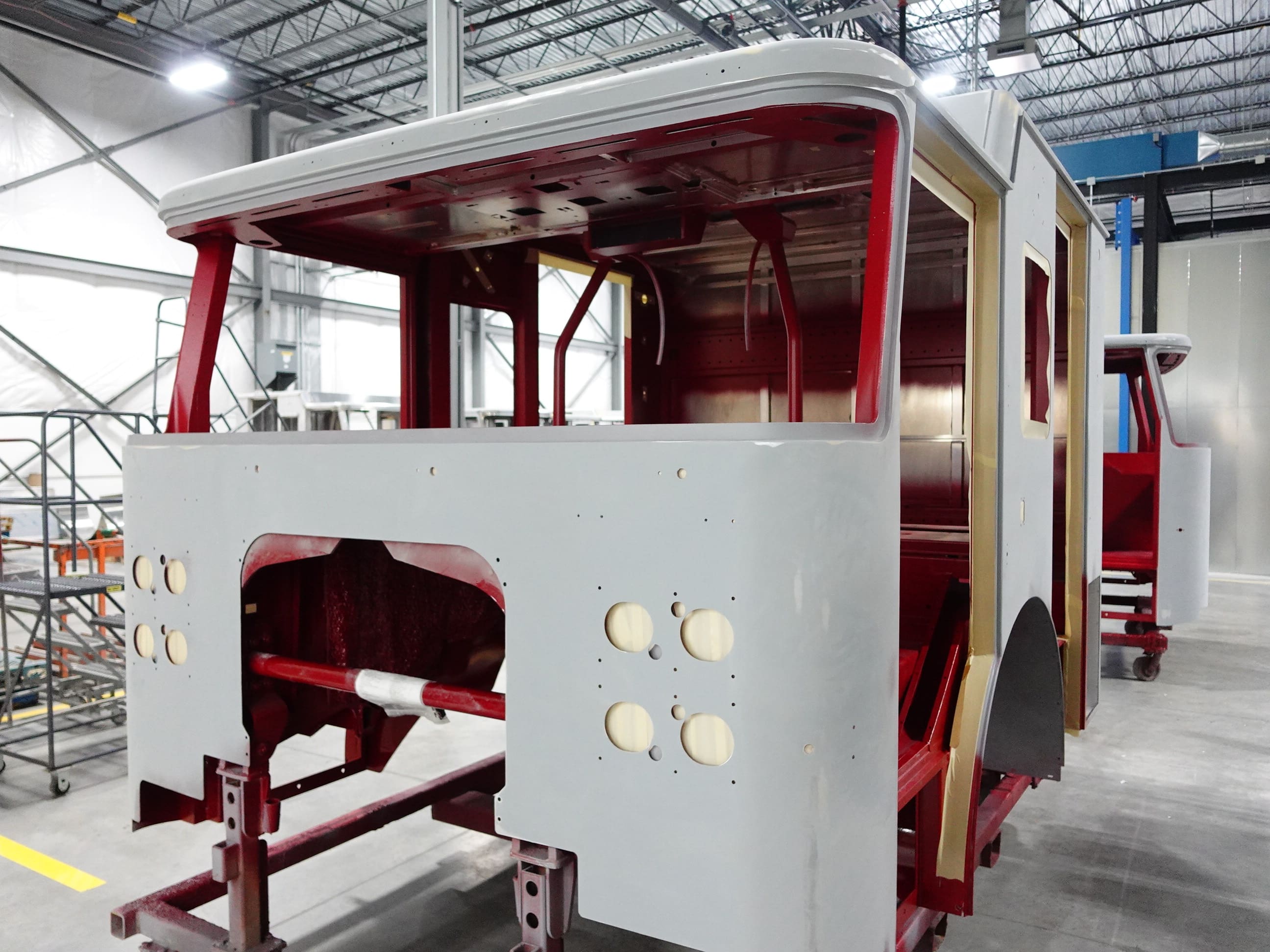

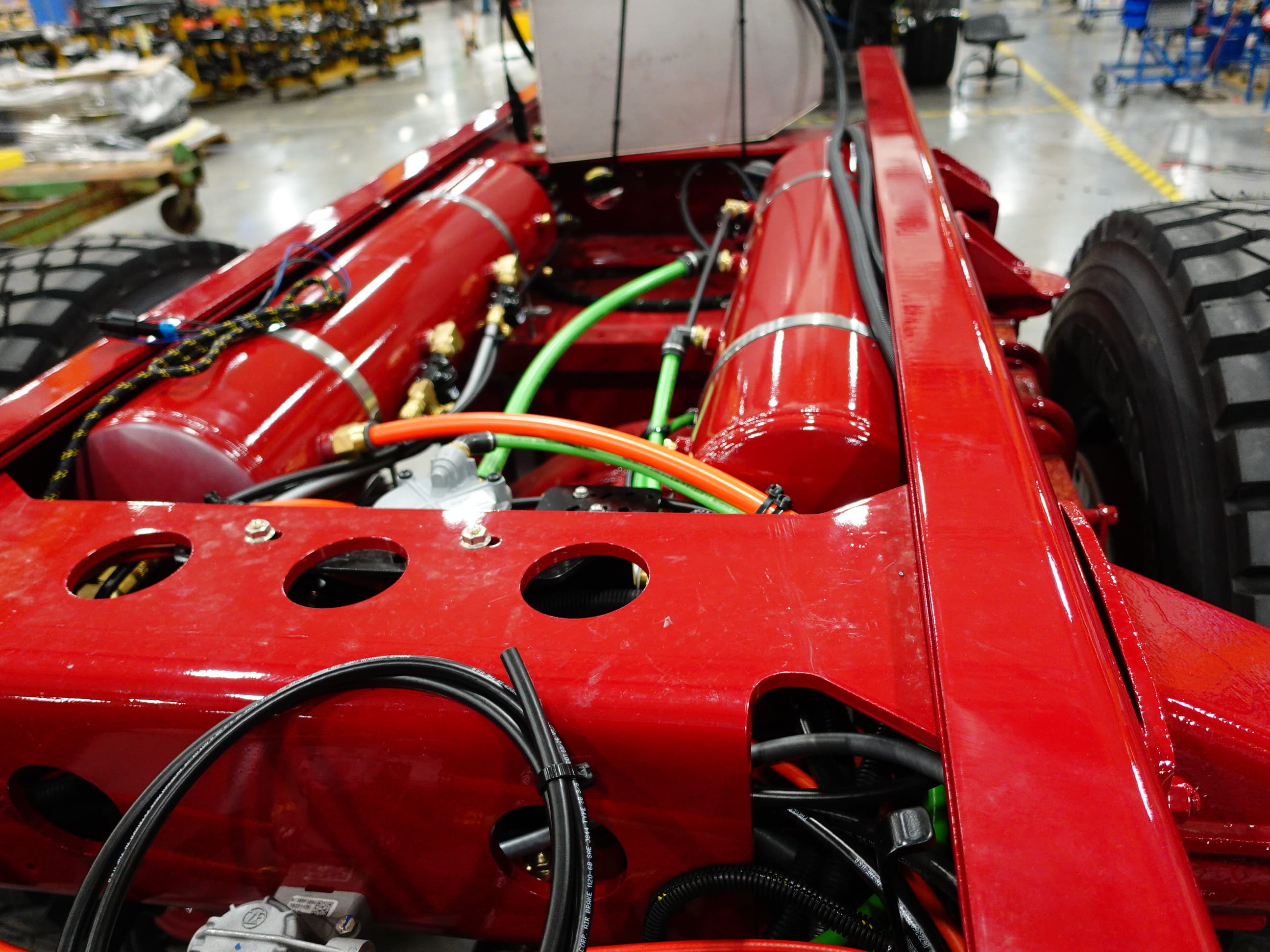

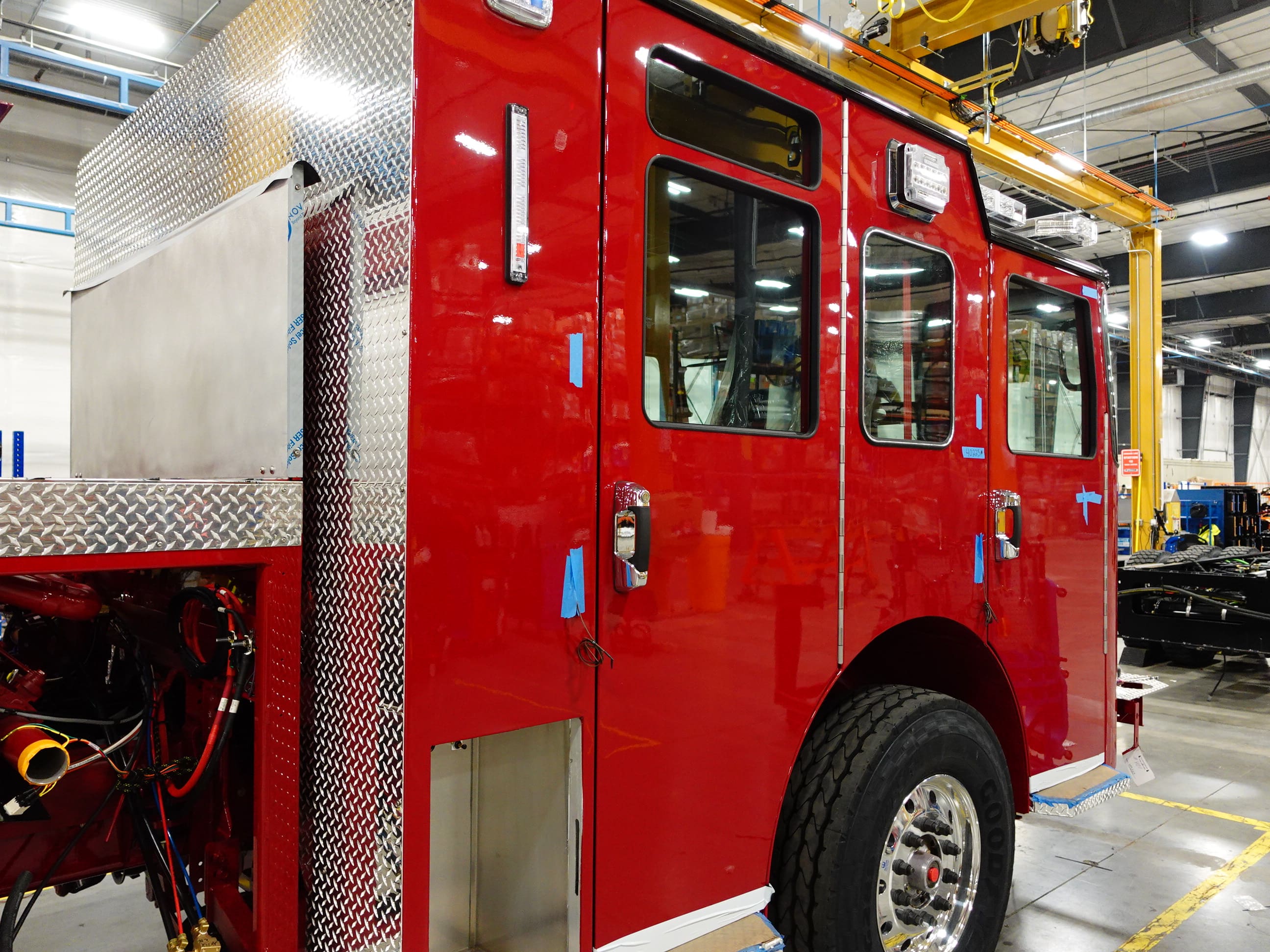

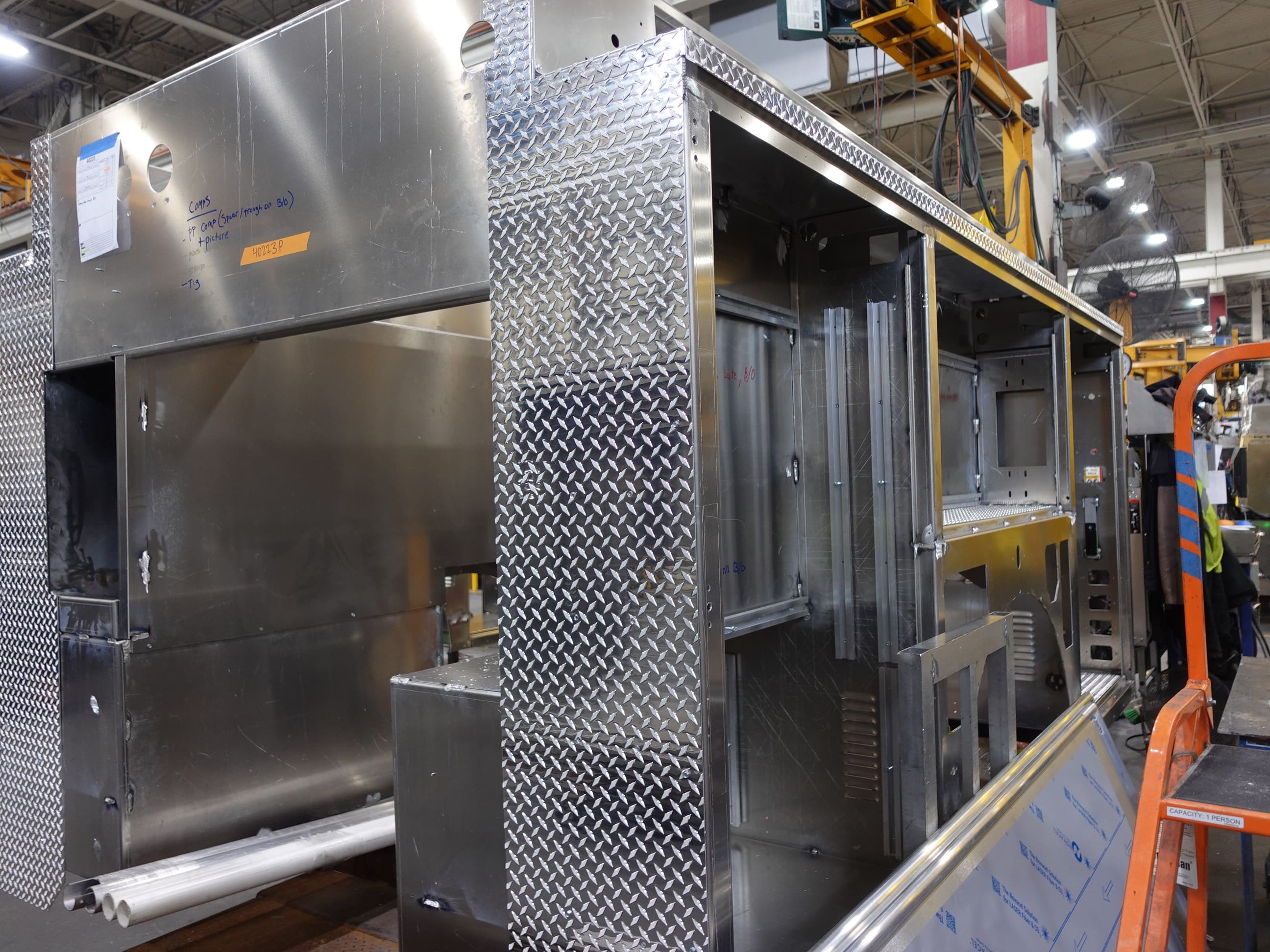

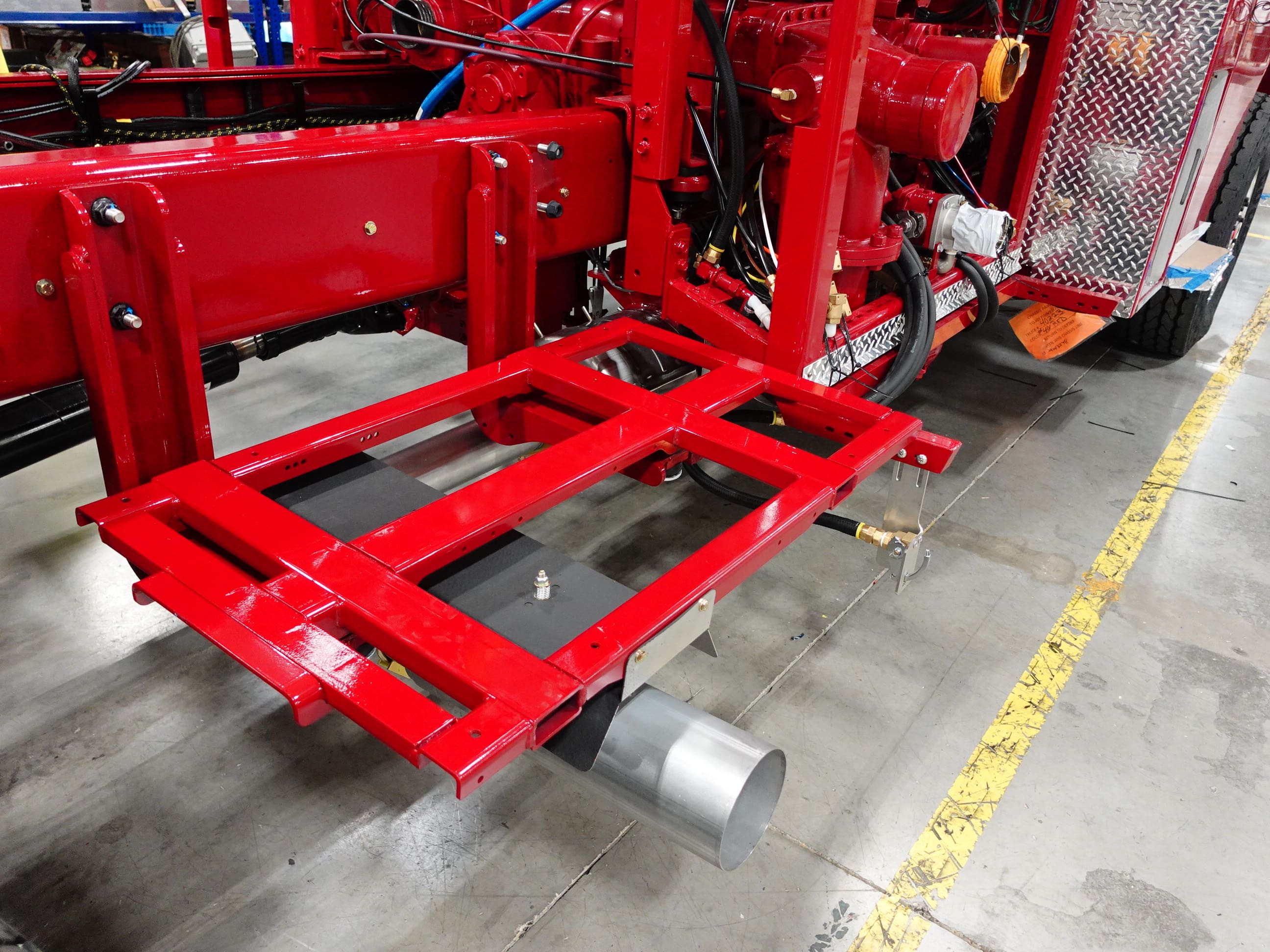

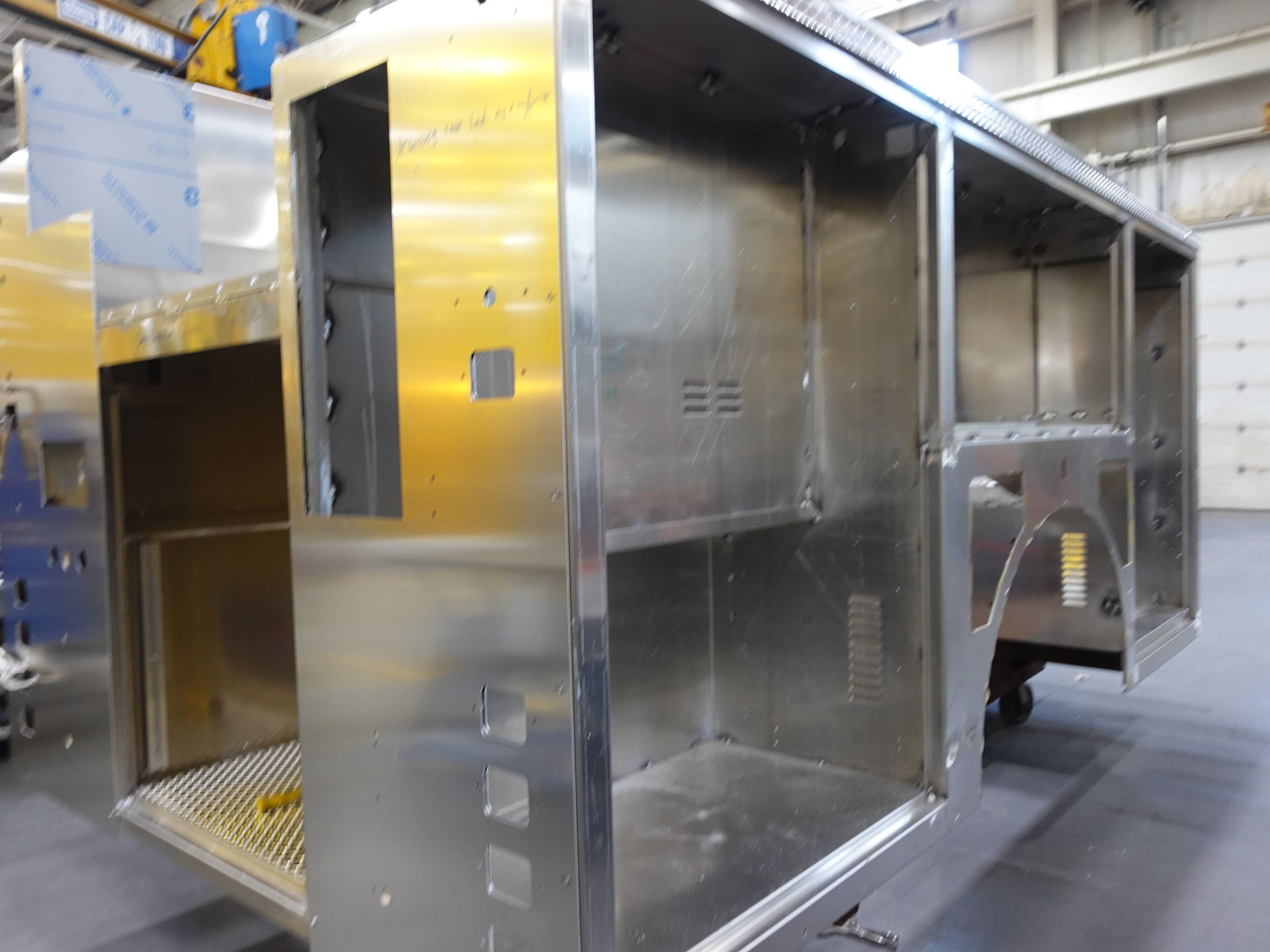

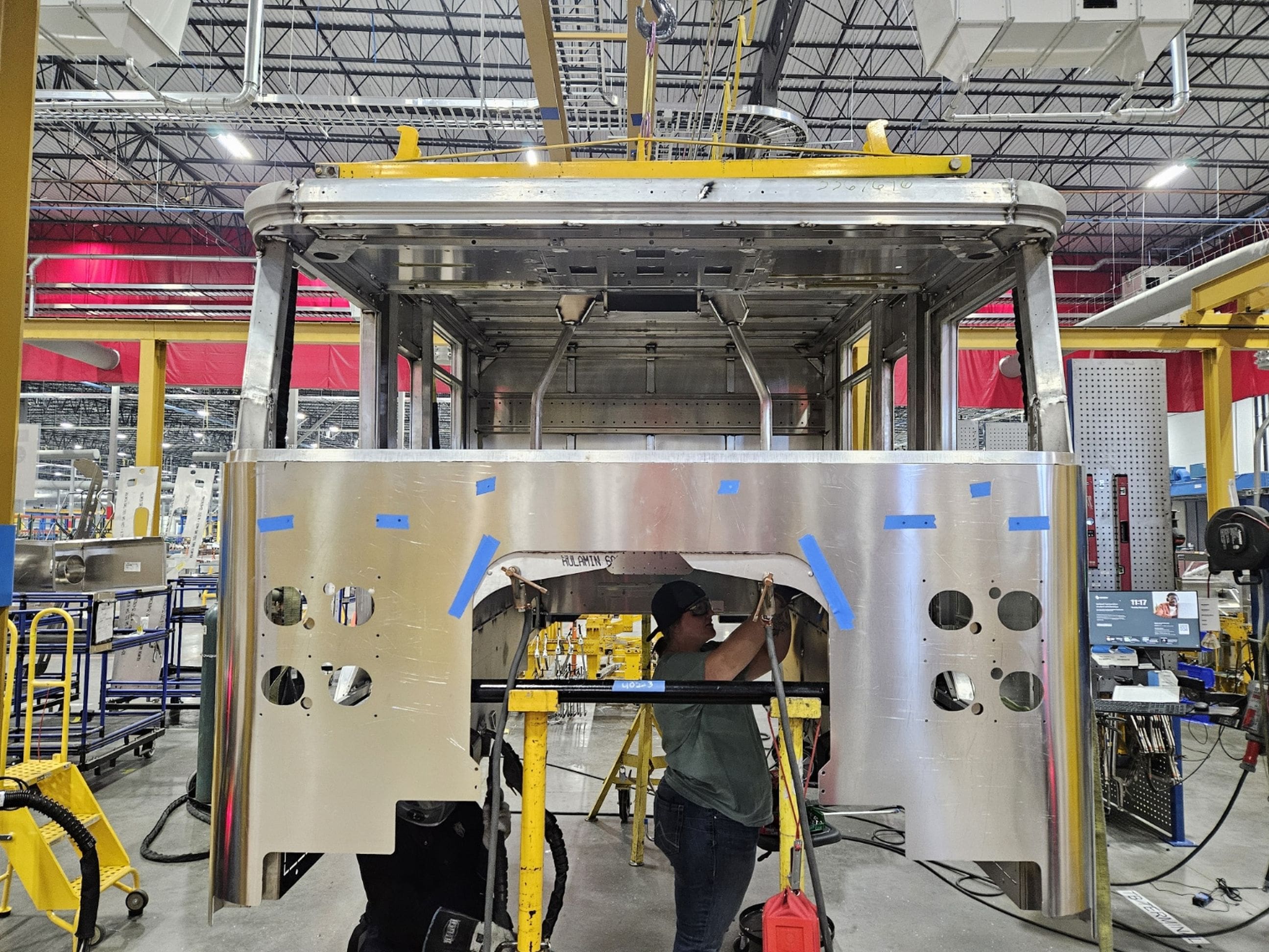

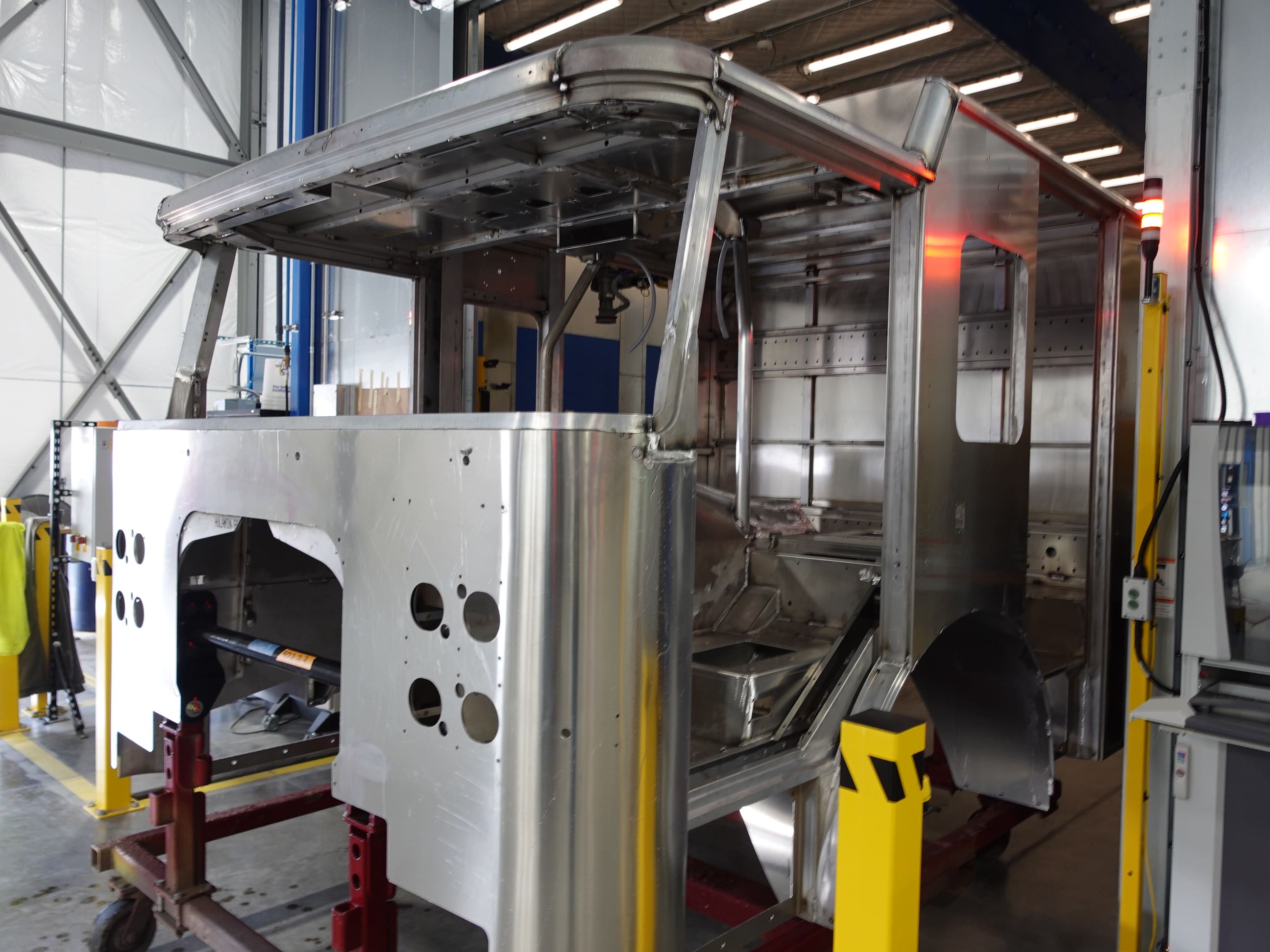

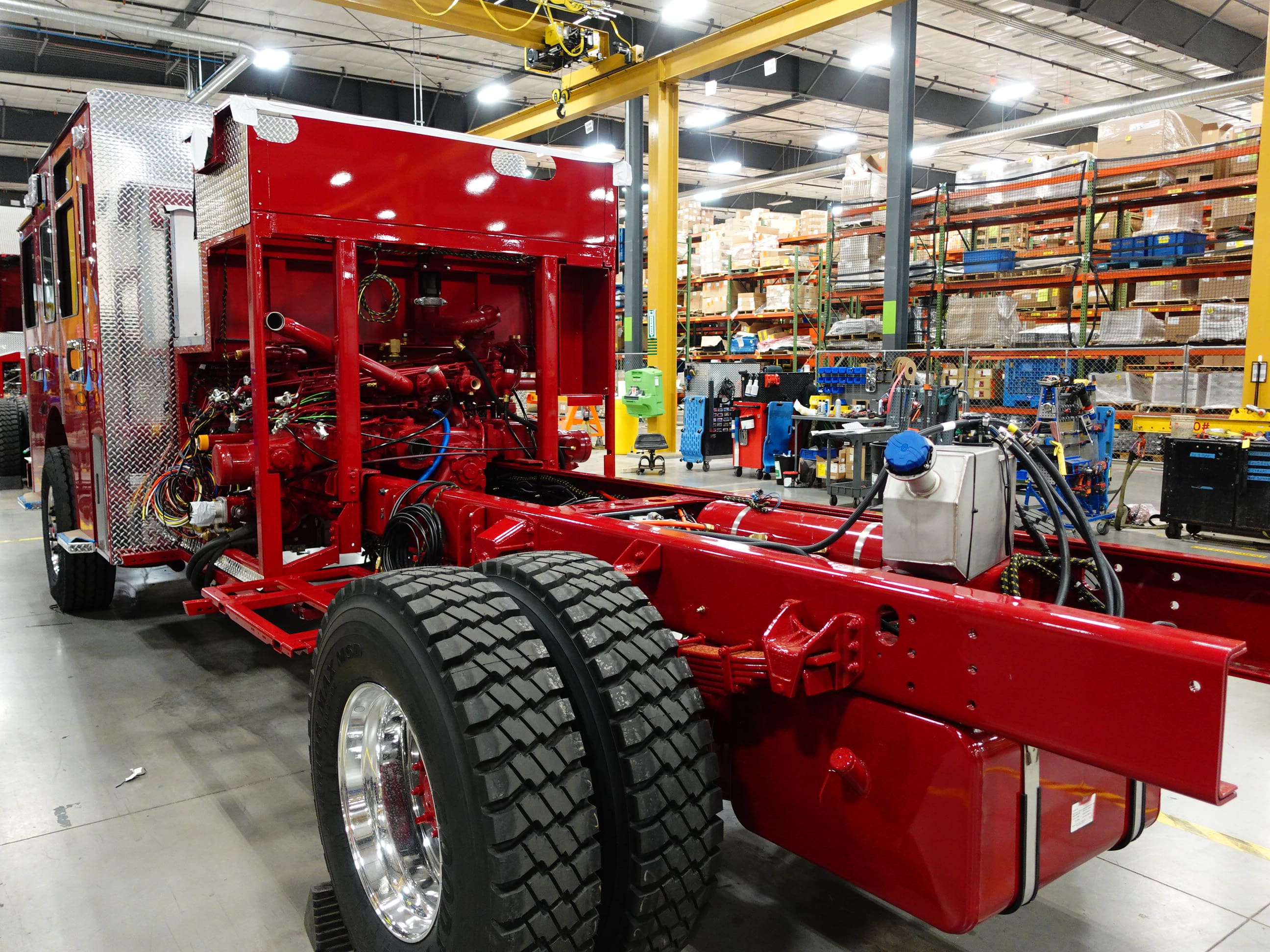

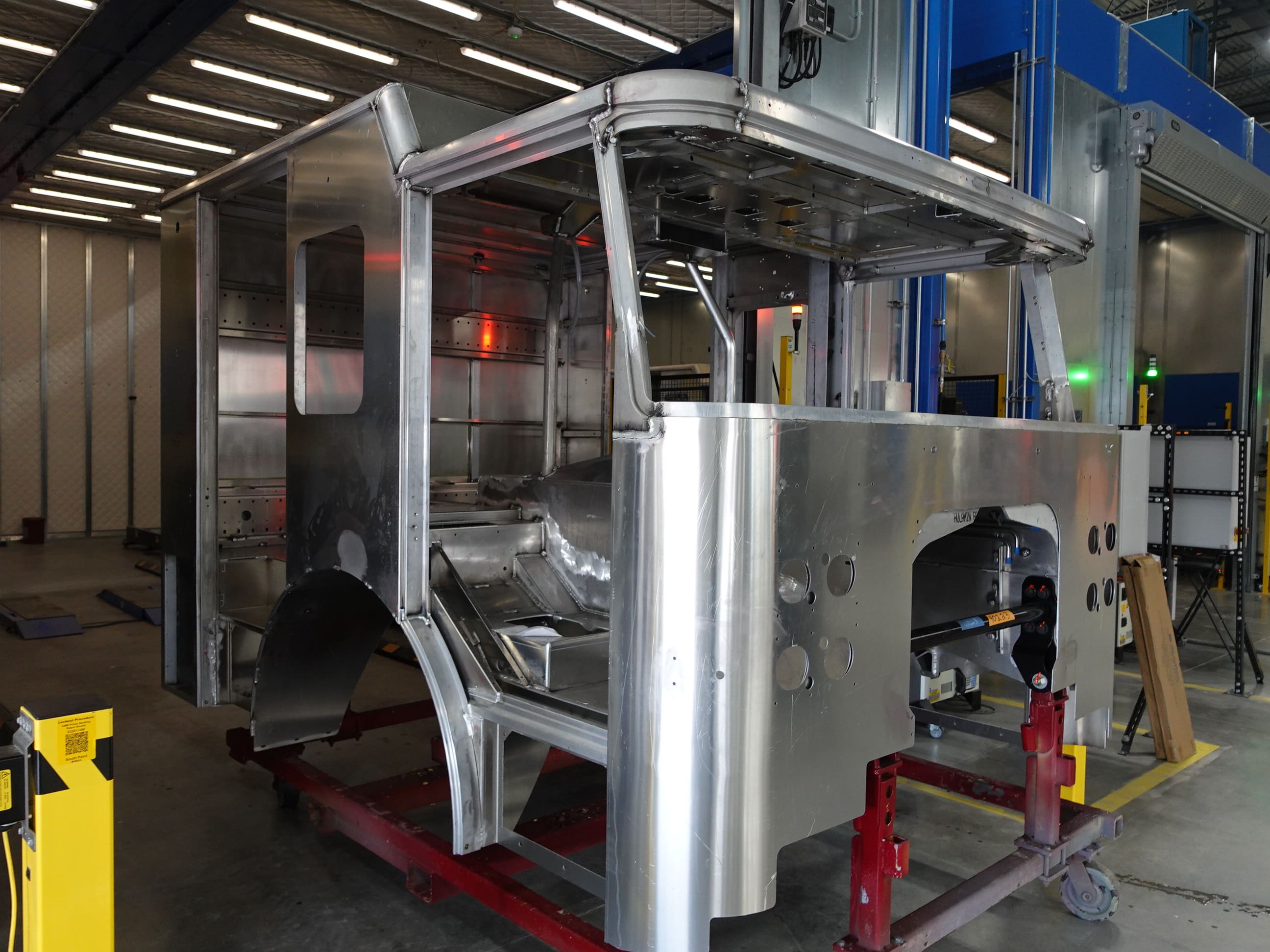

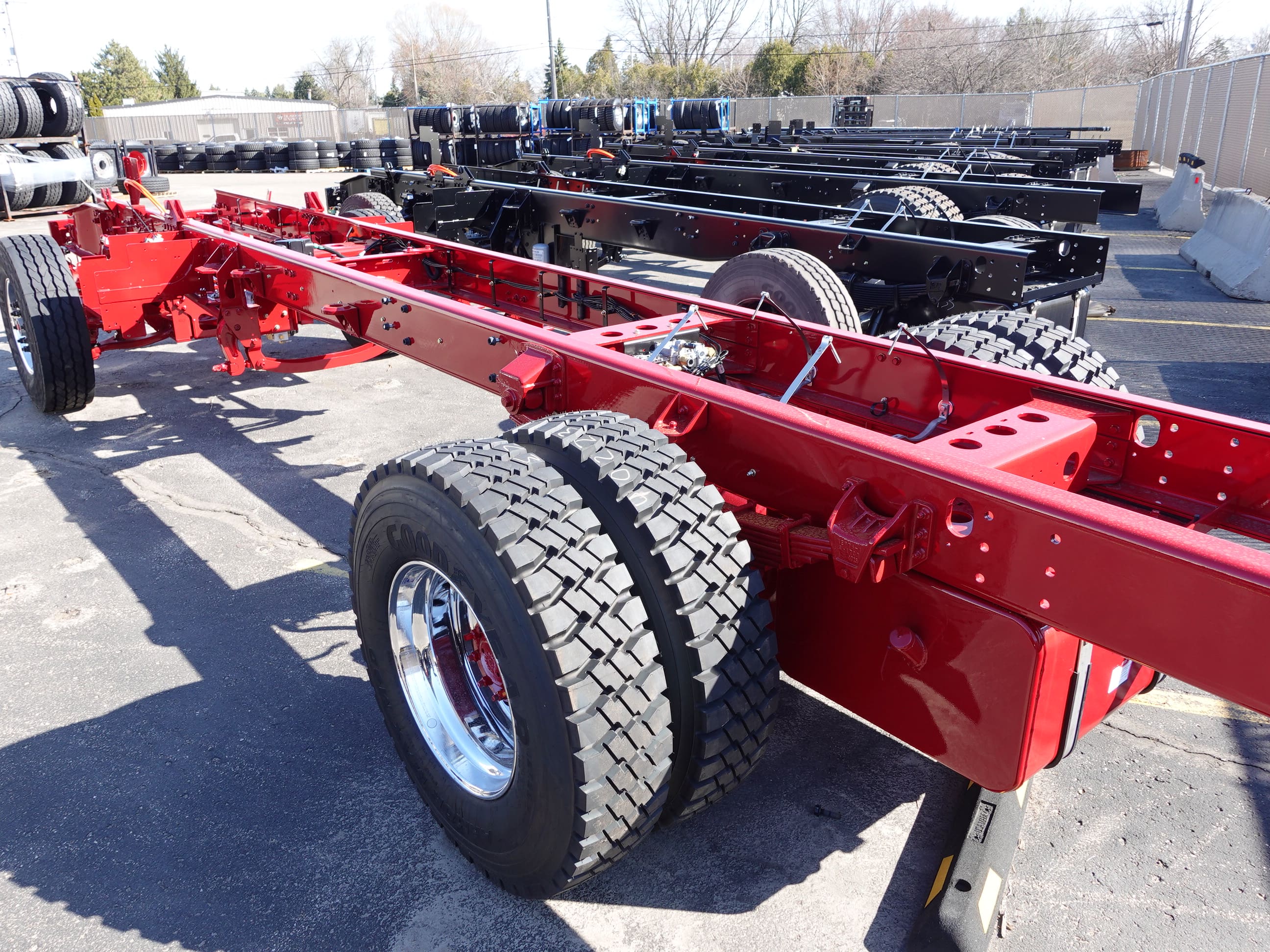

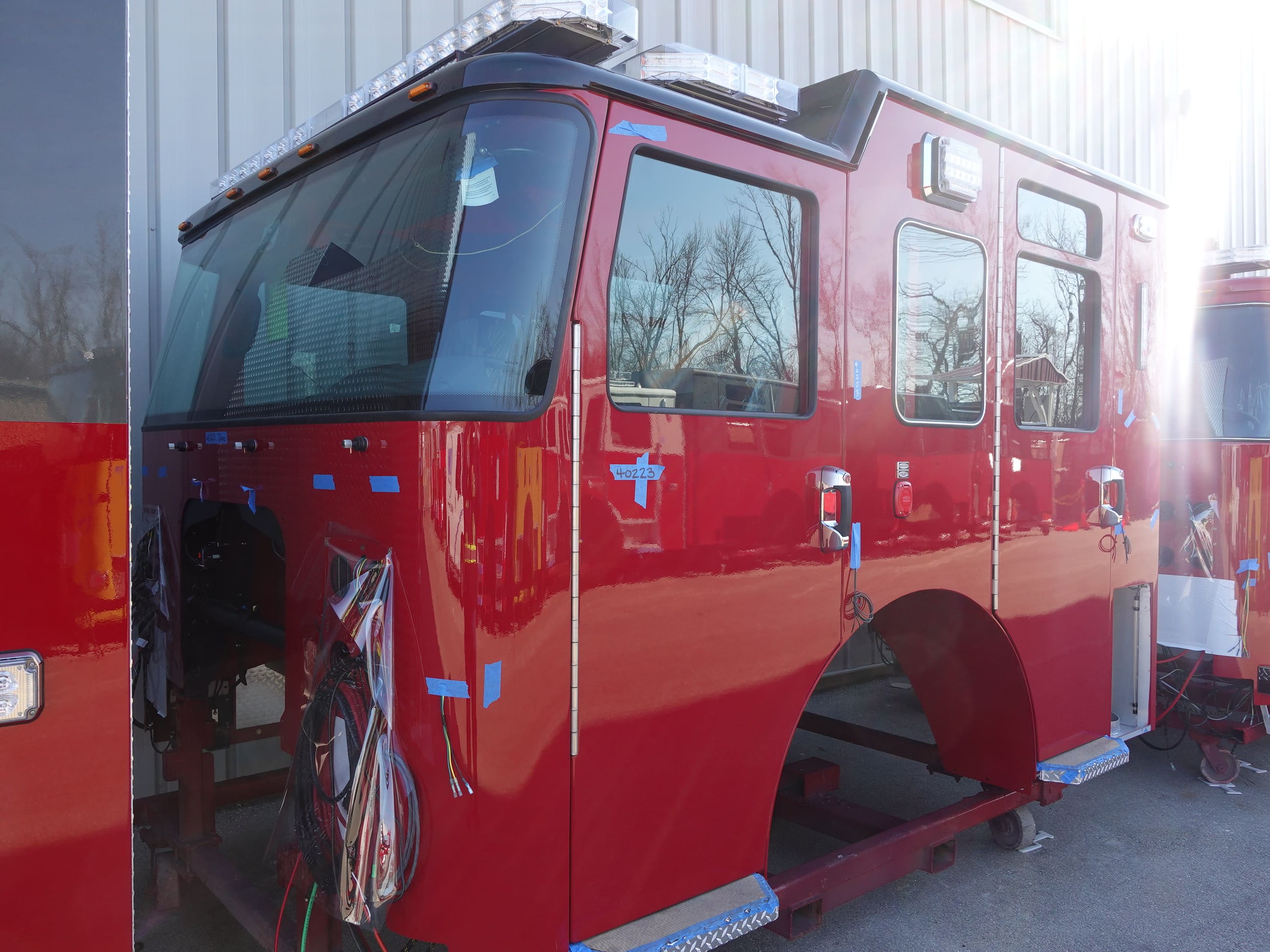

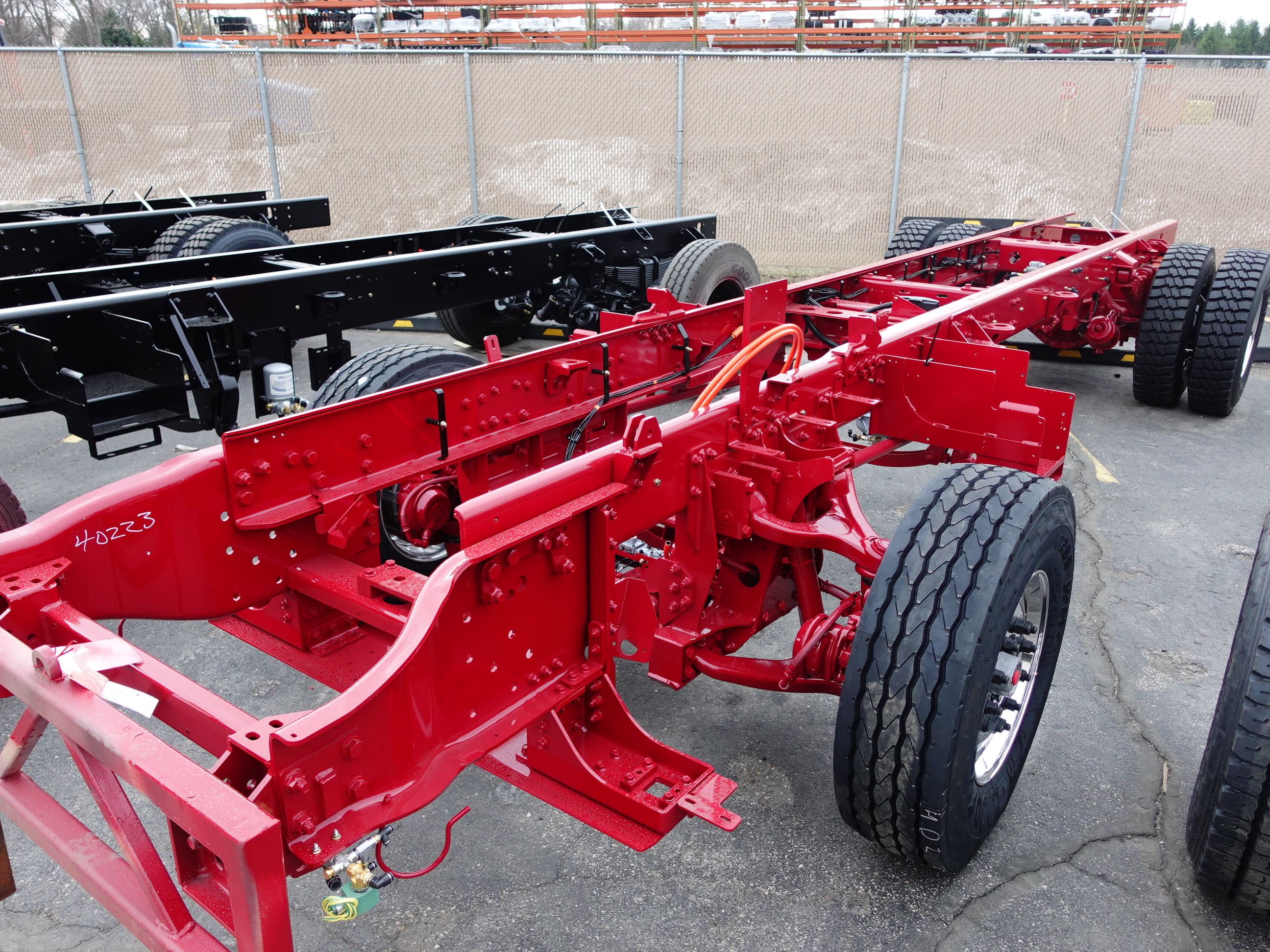

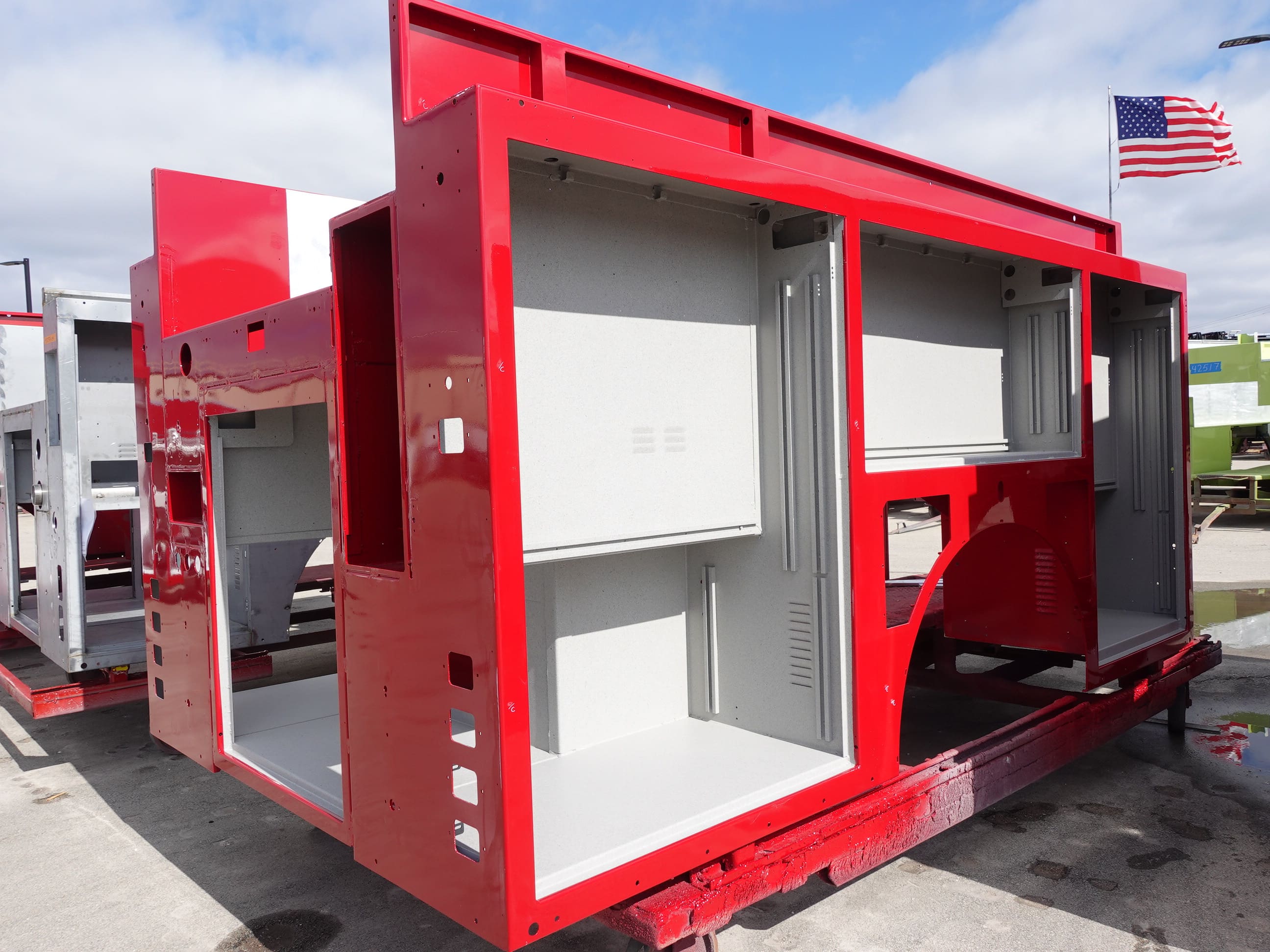

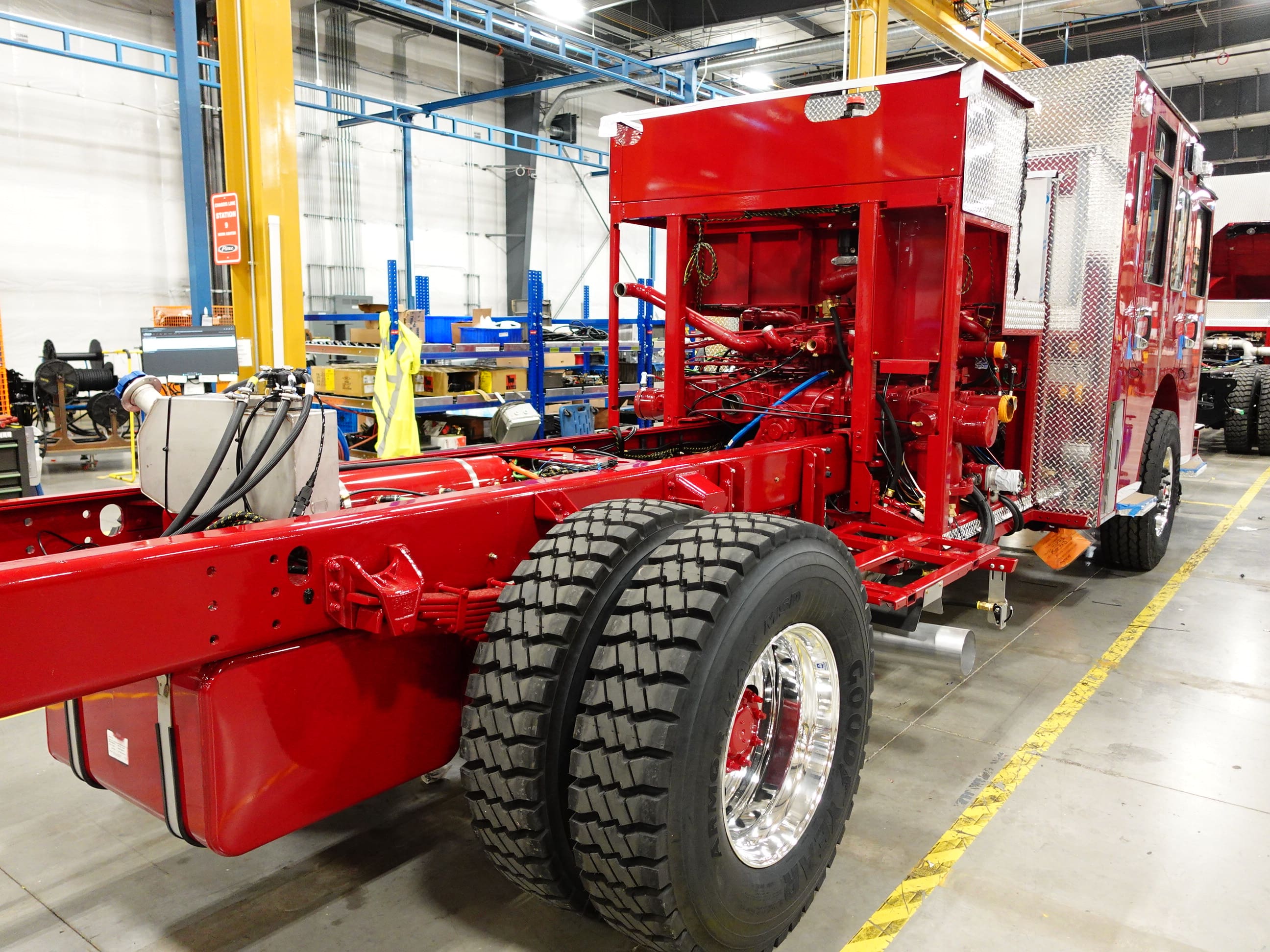

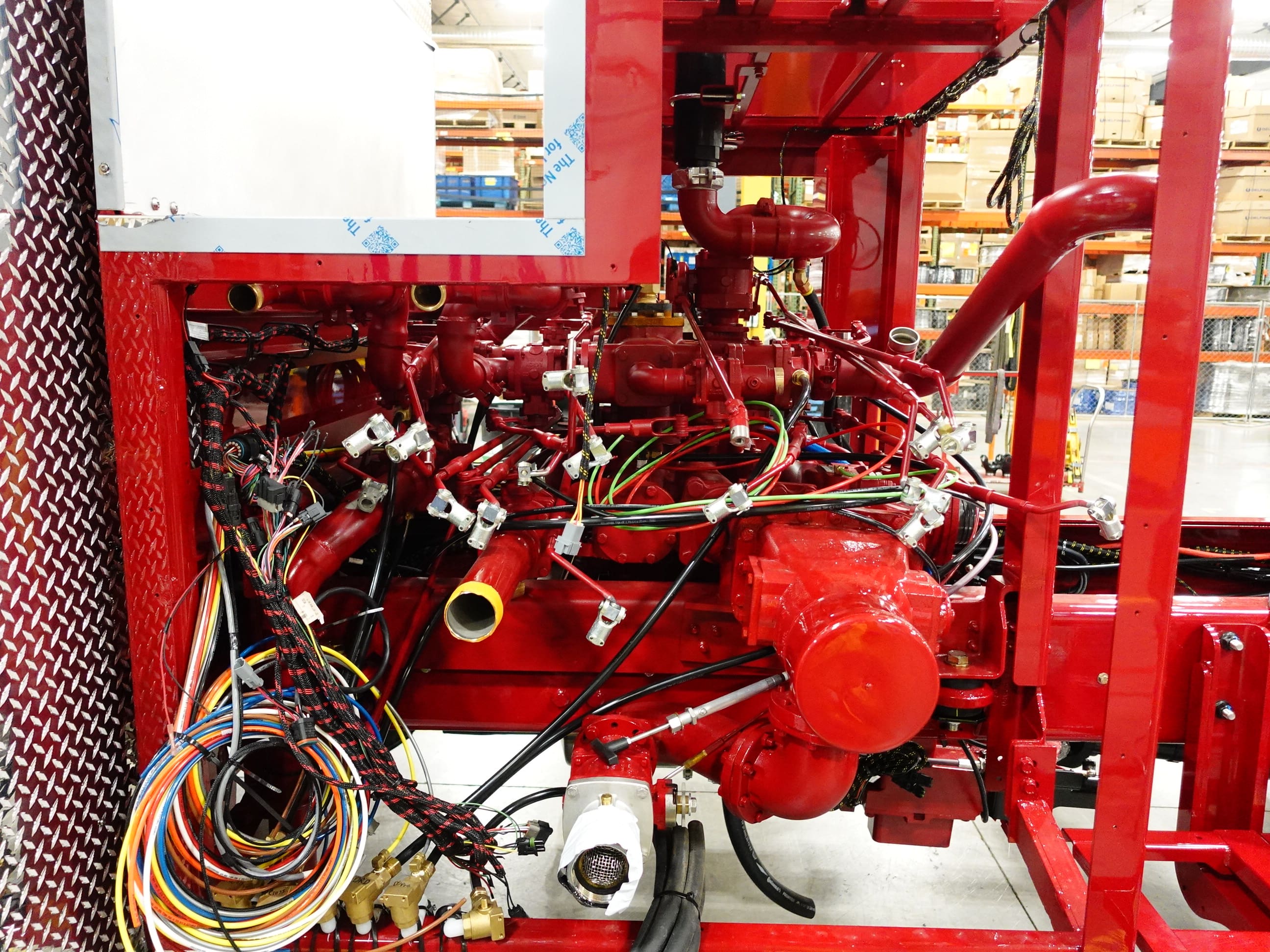

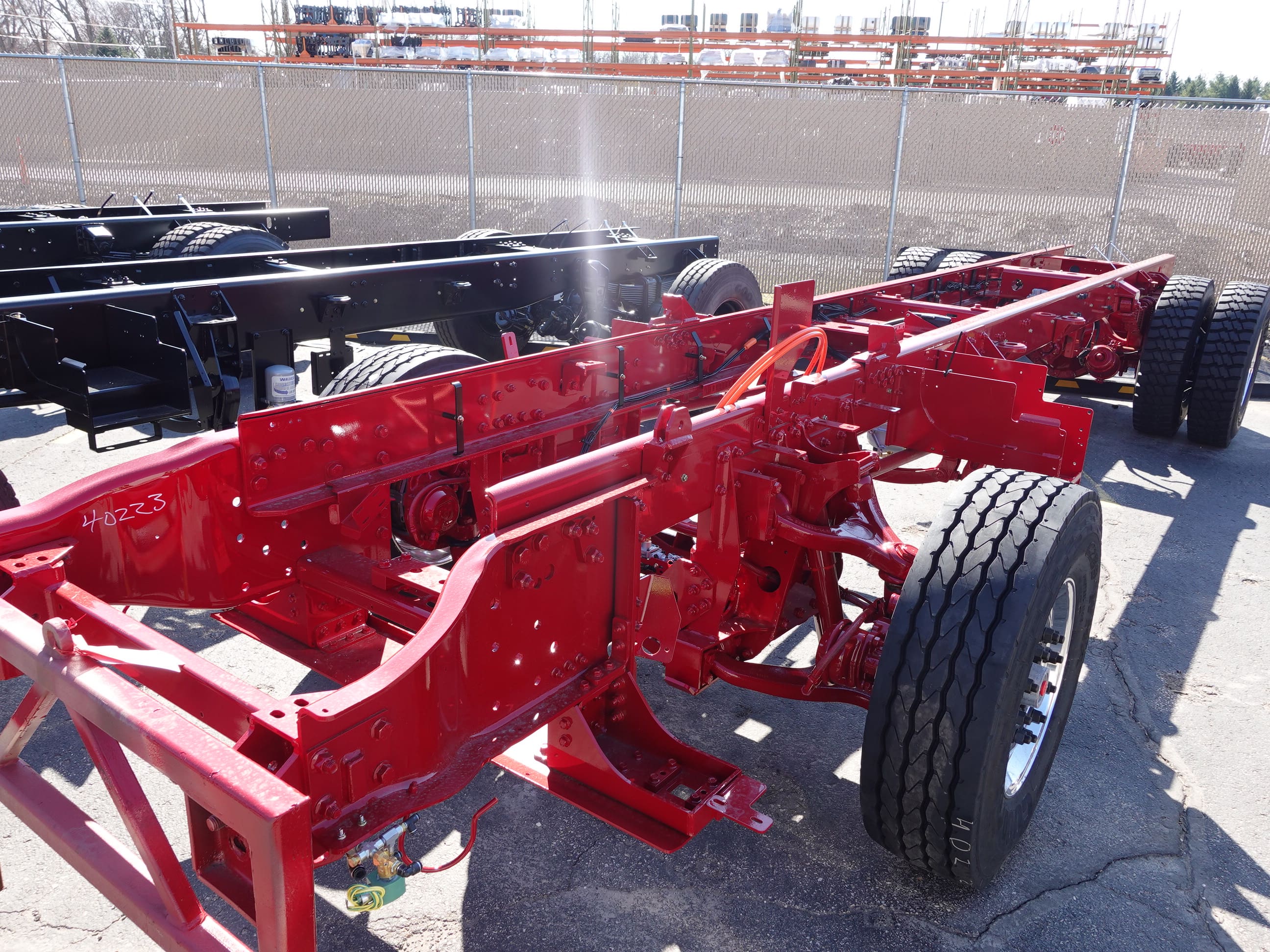

In this report your cab and pump house were merged with the frame followed by body installation at the start of initial apparatus assembly.

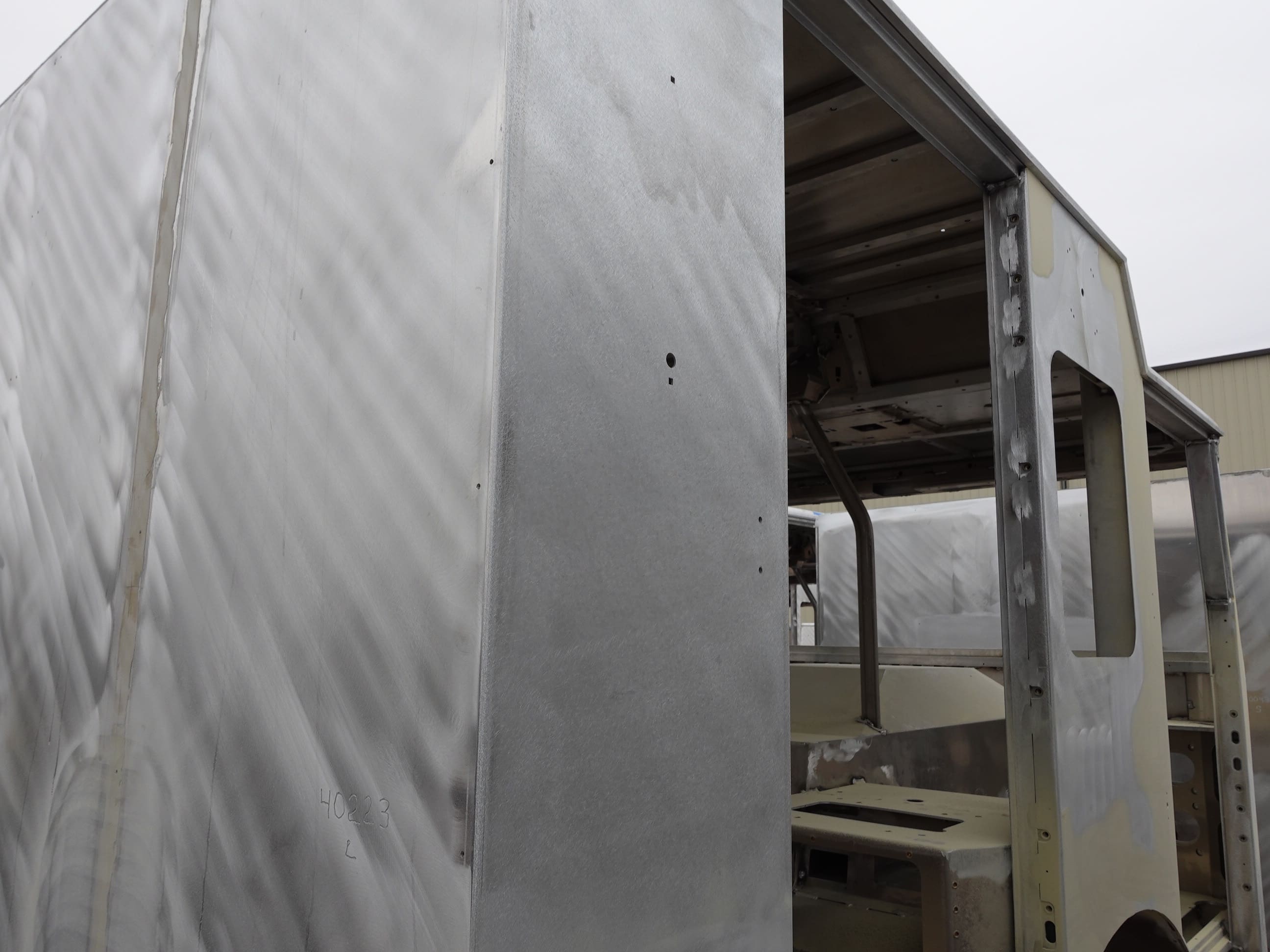

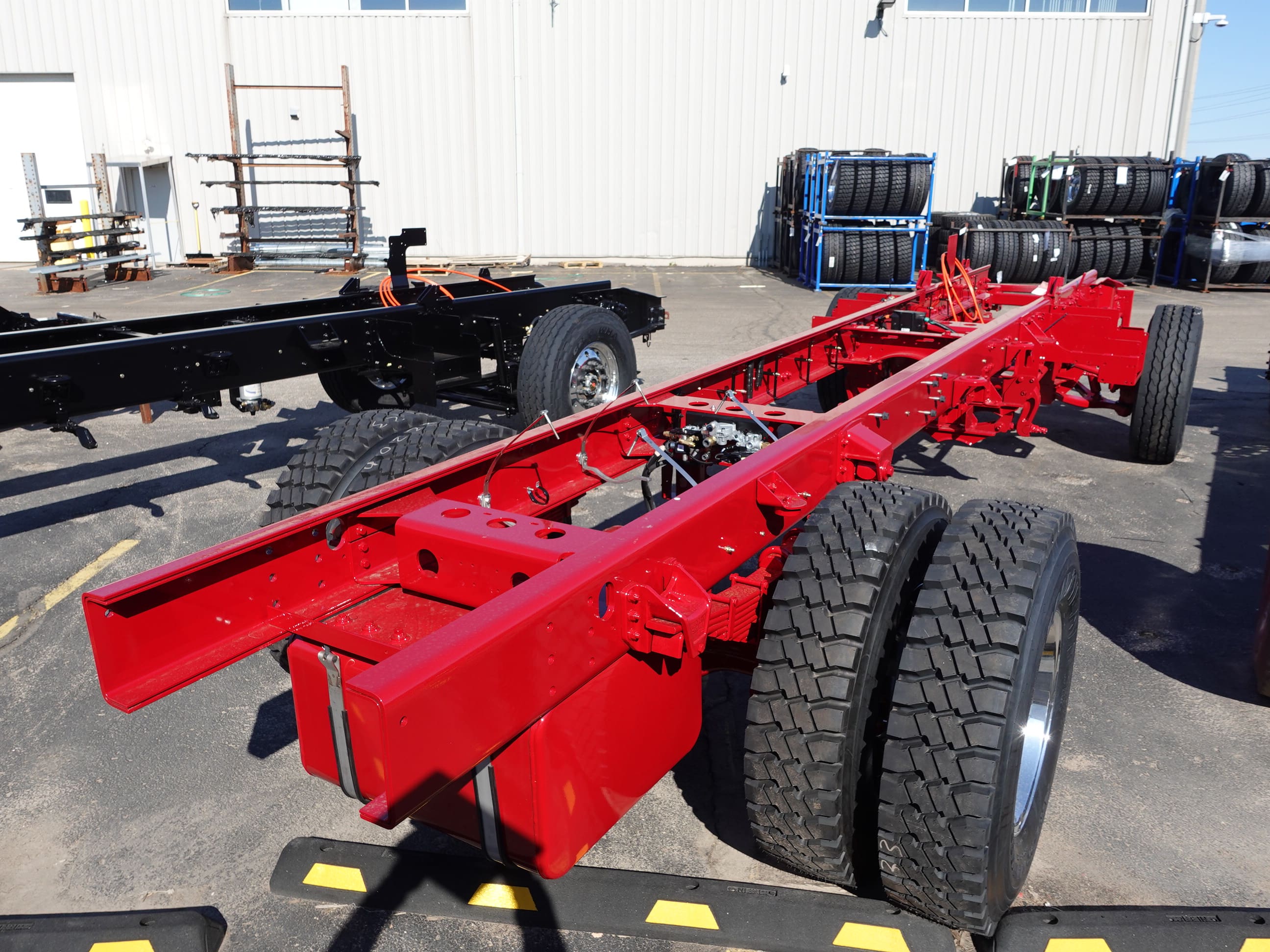

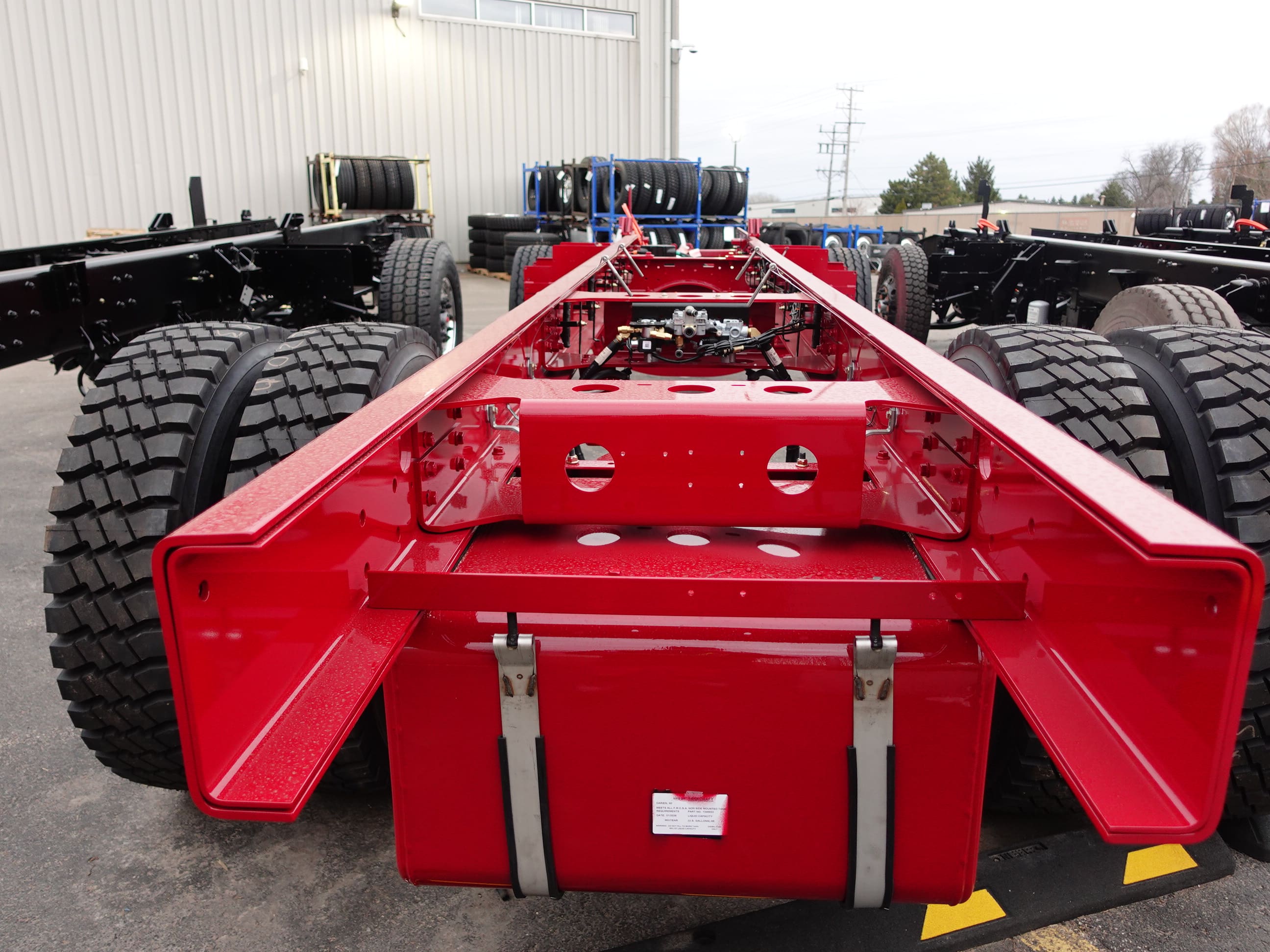

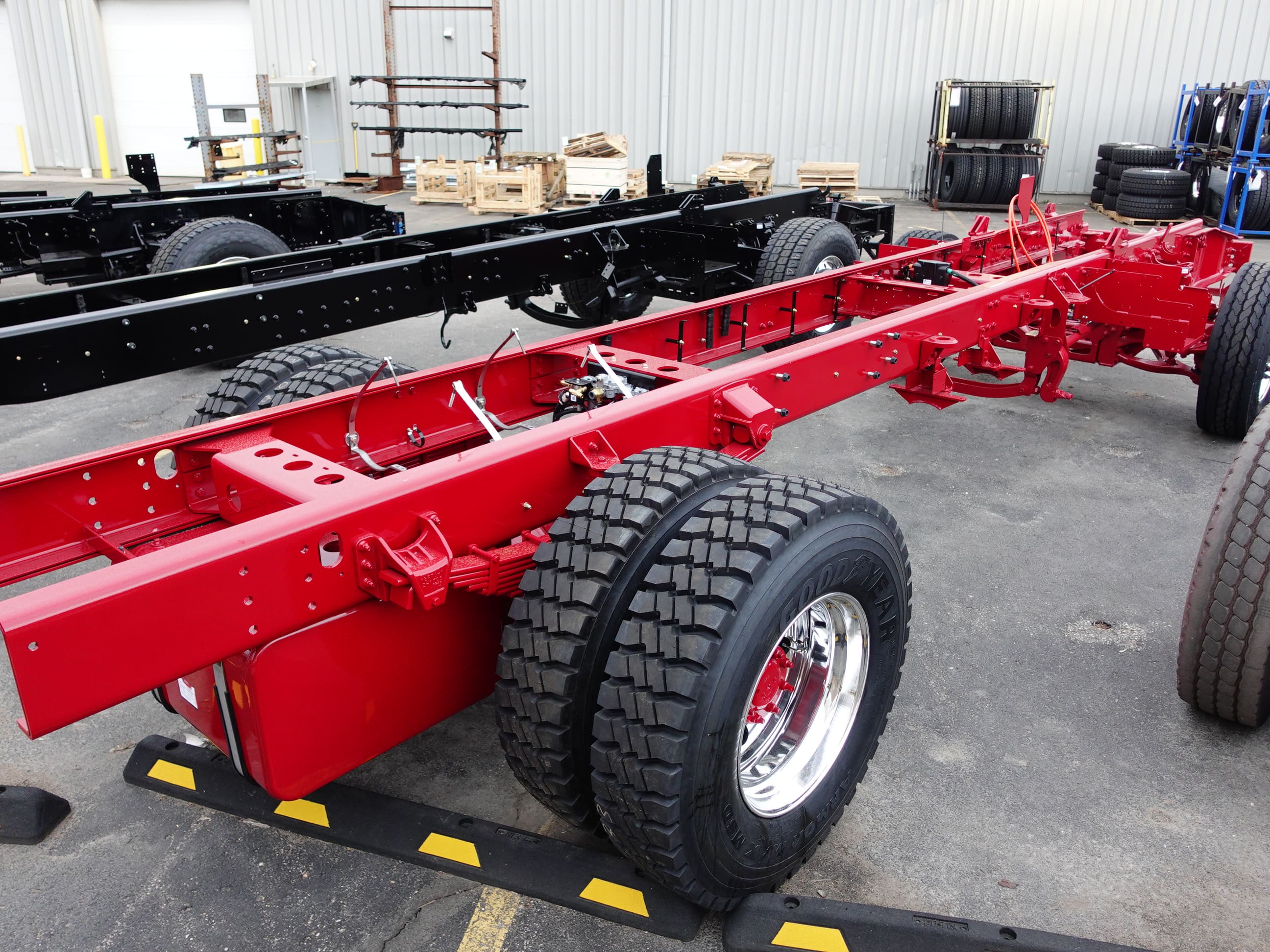

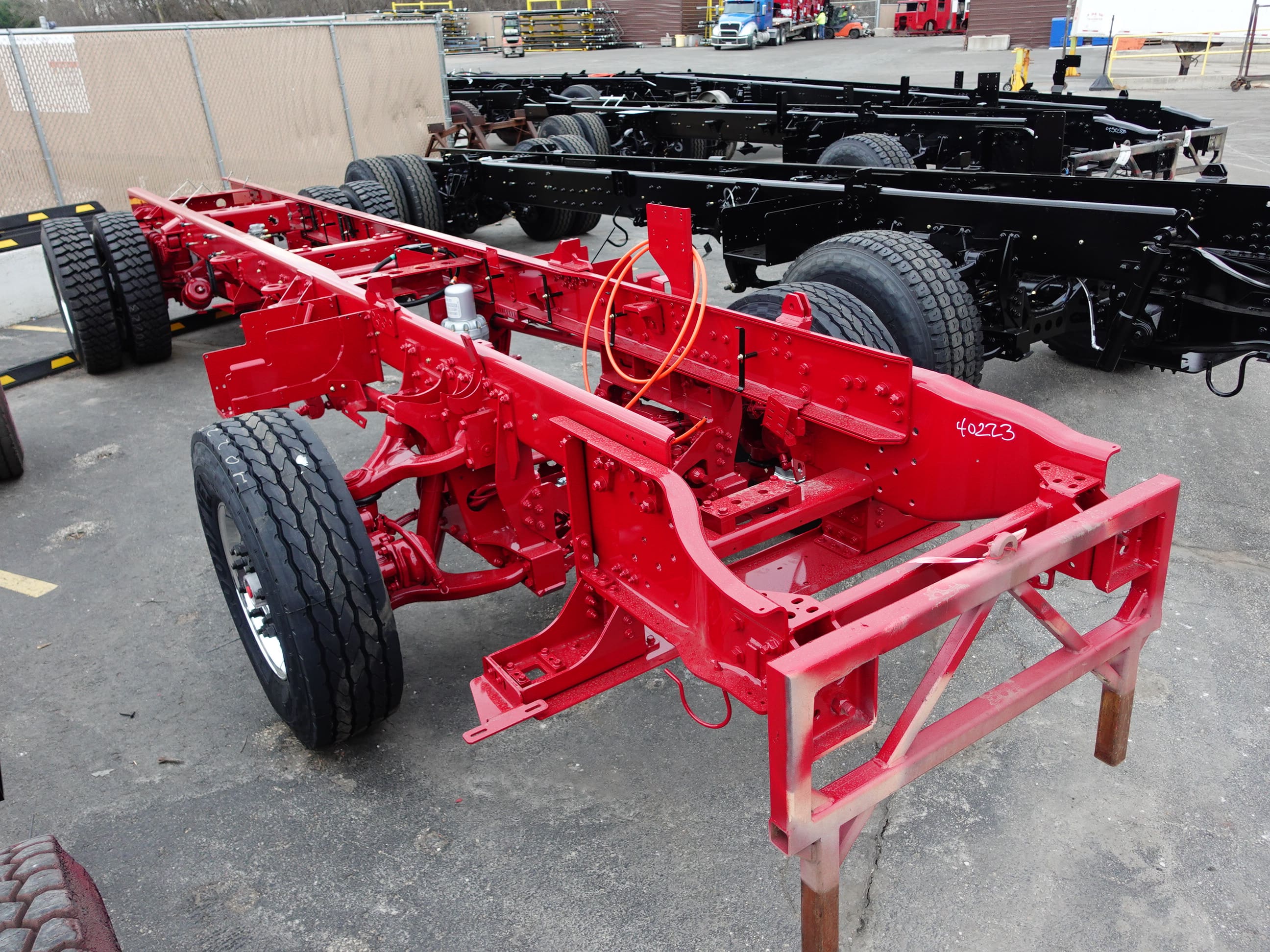

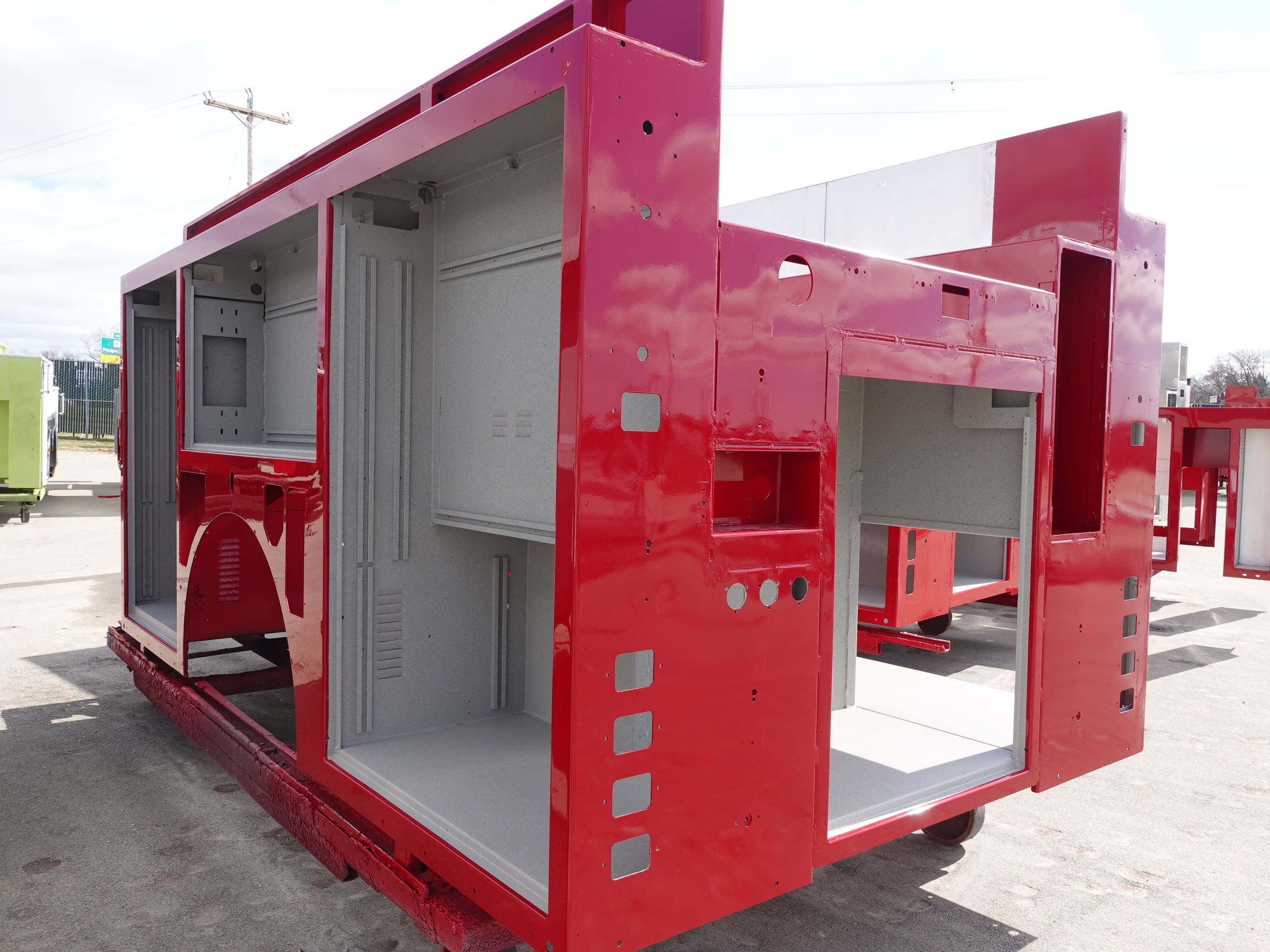

04-10-26

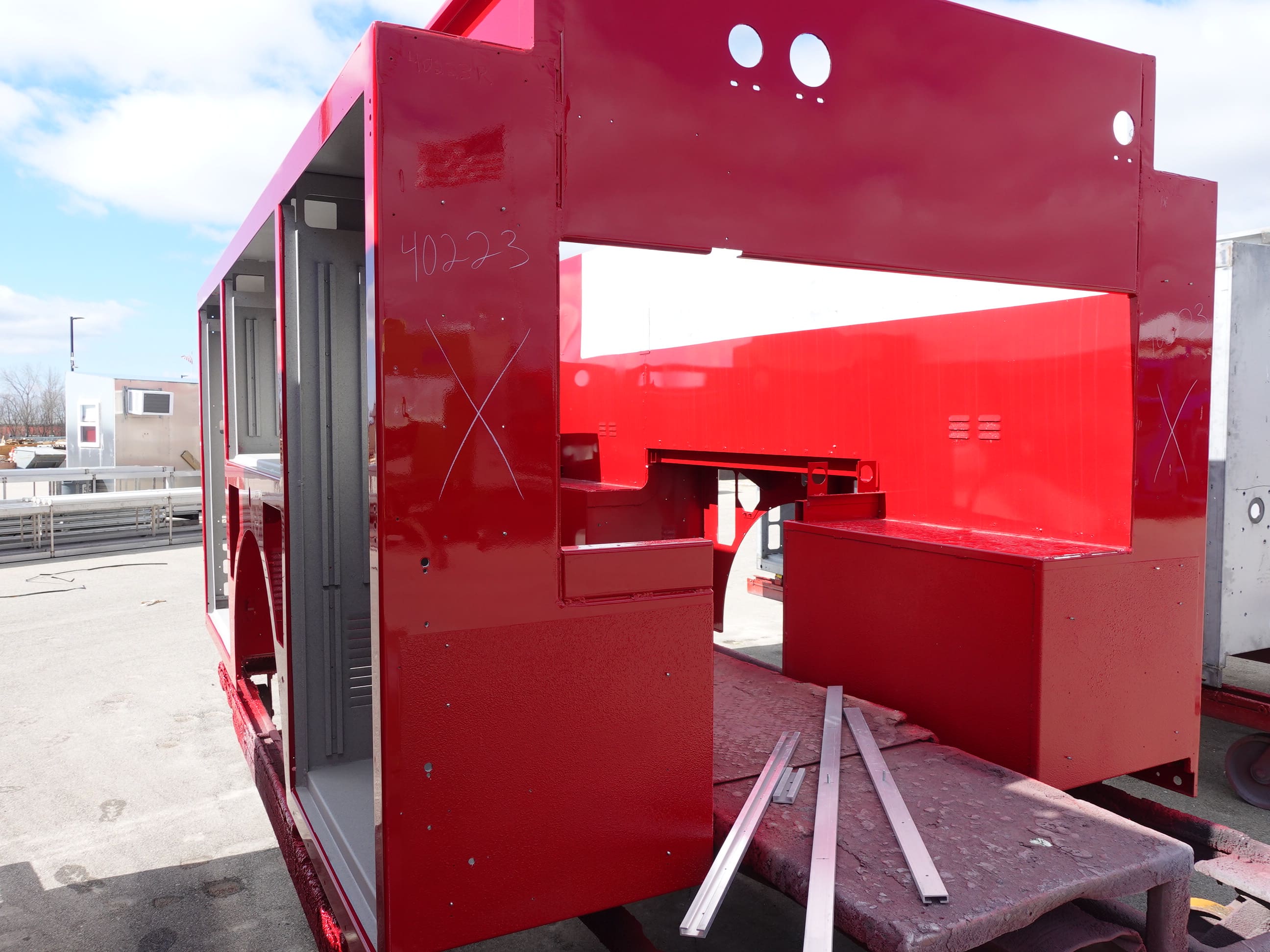

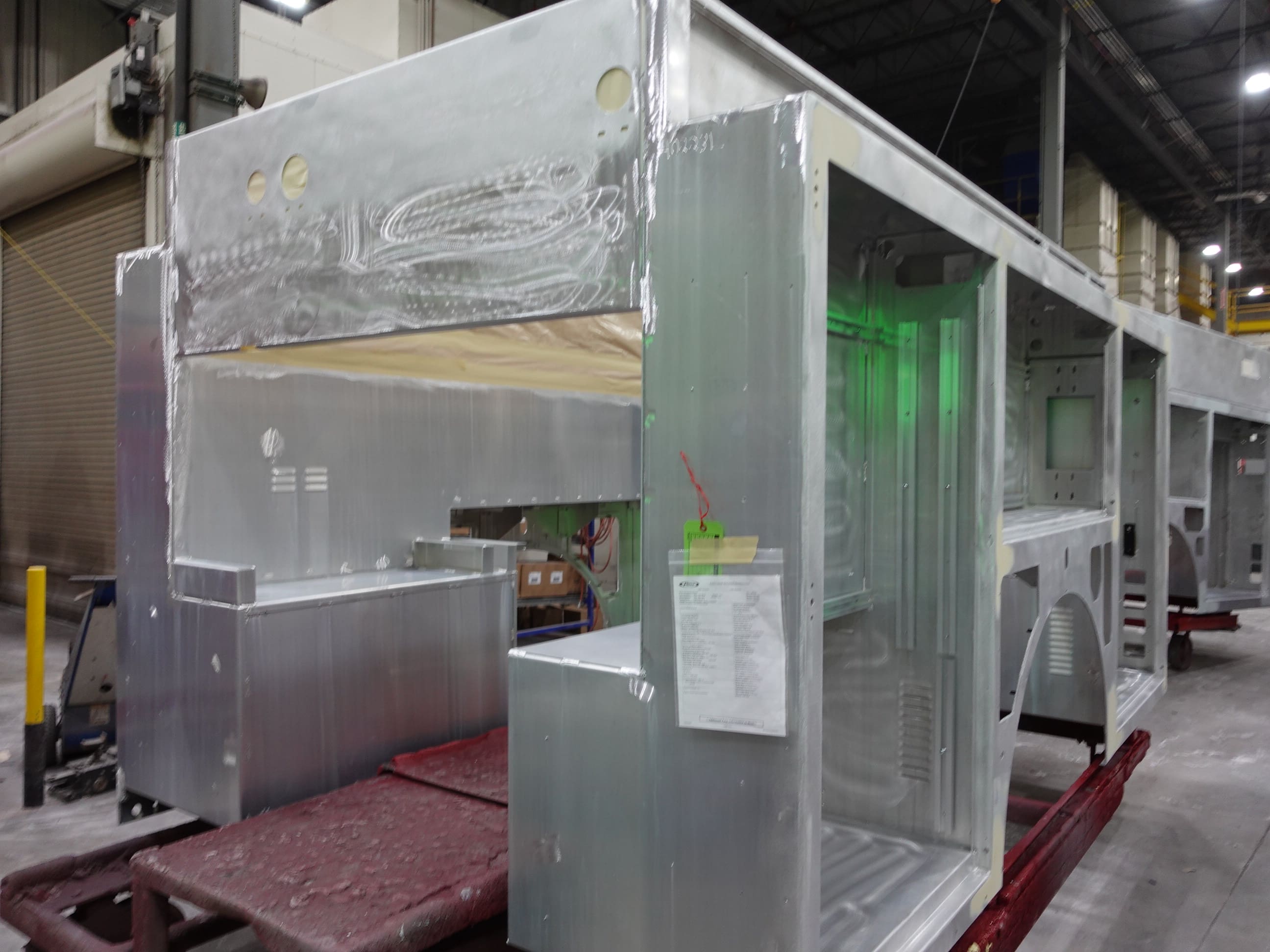

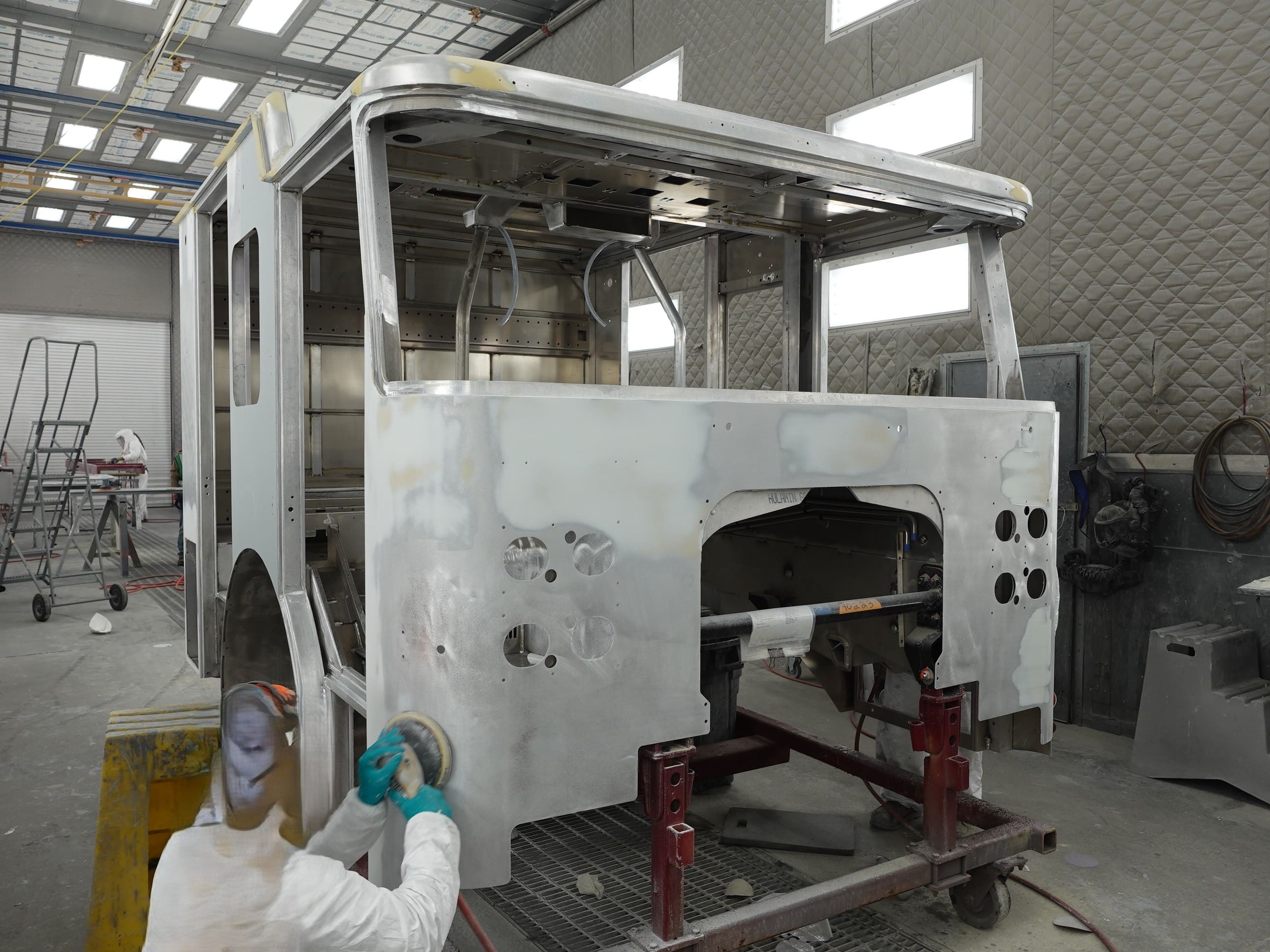

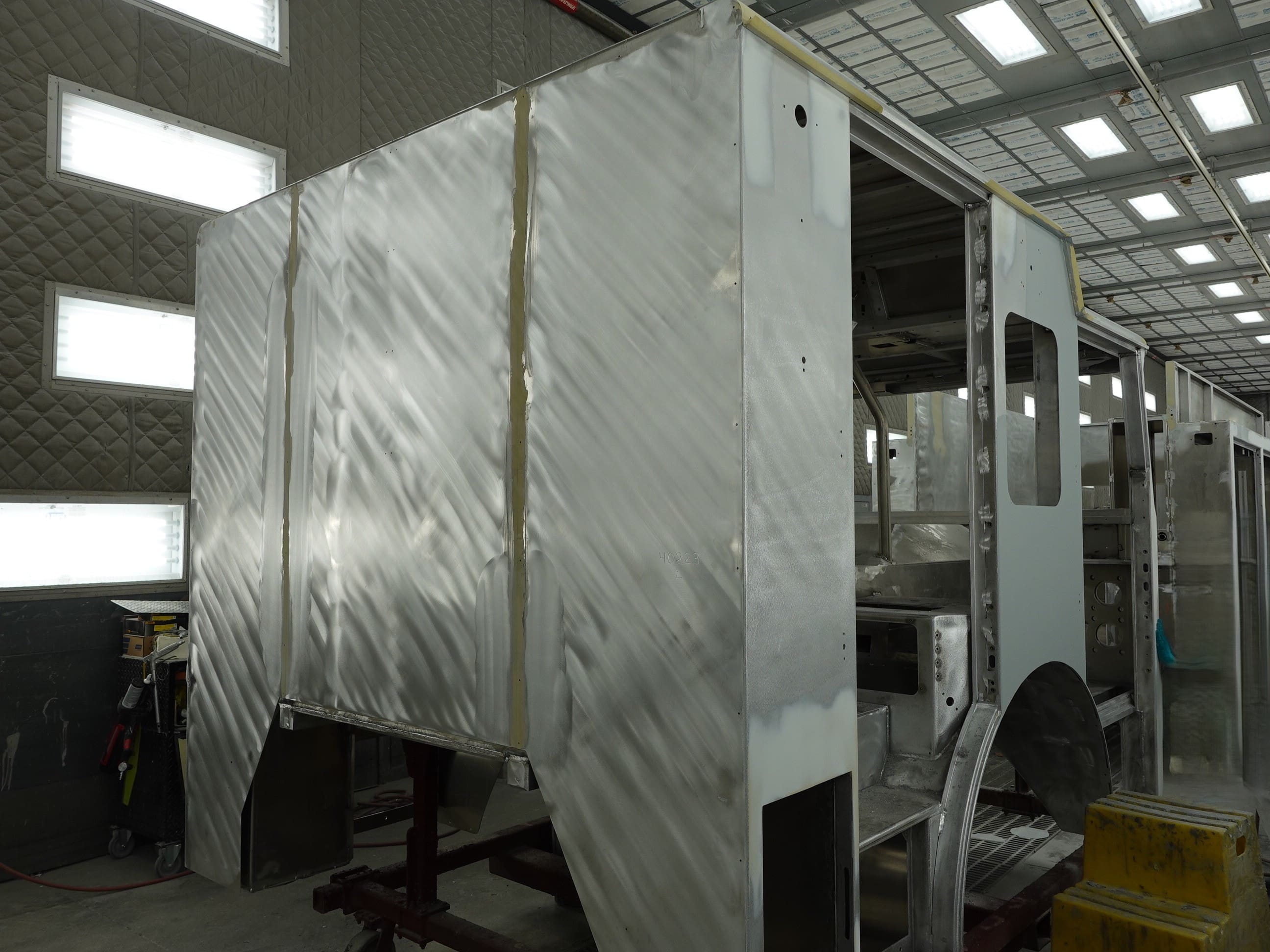

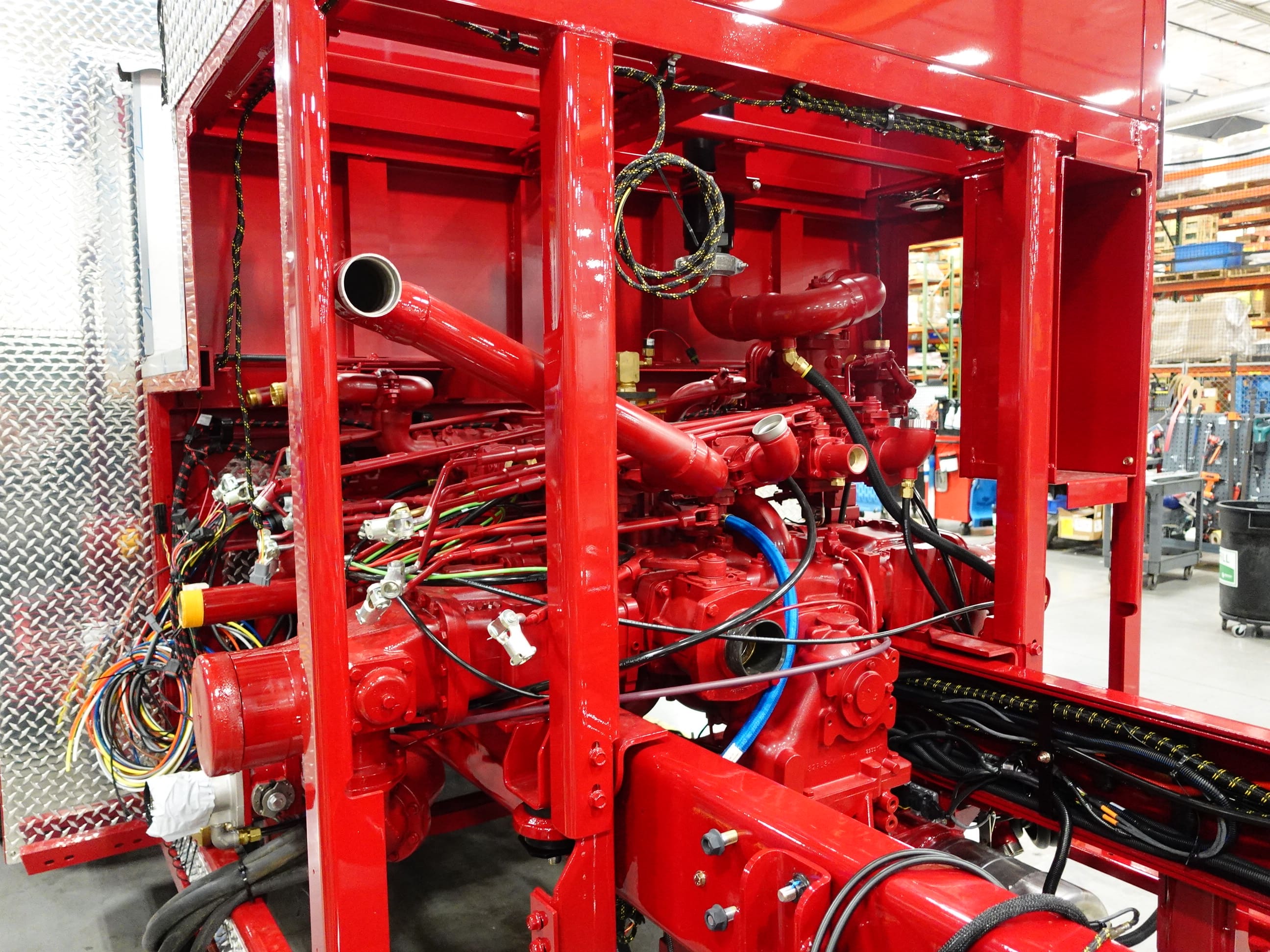

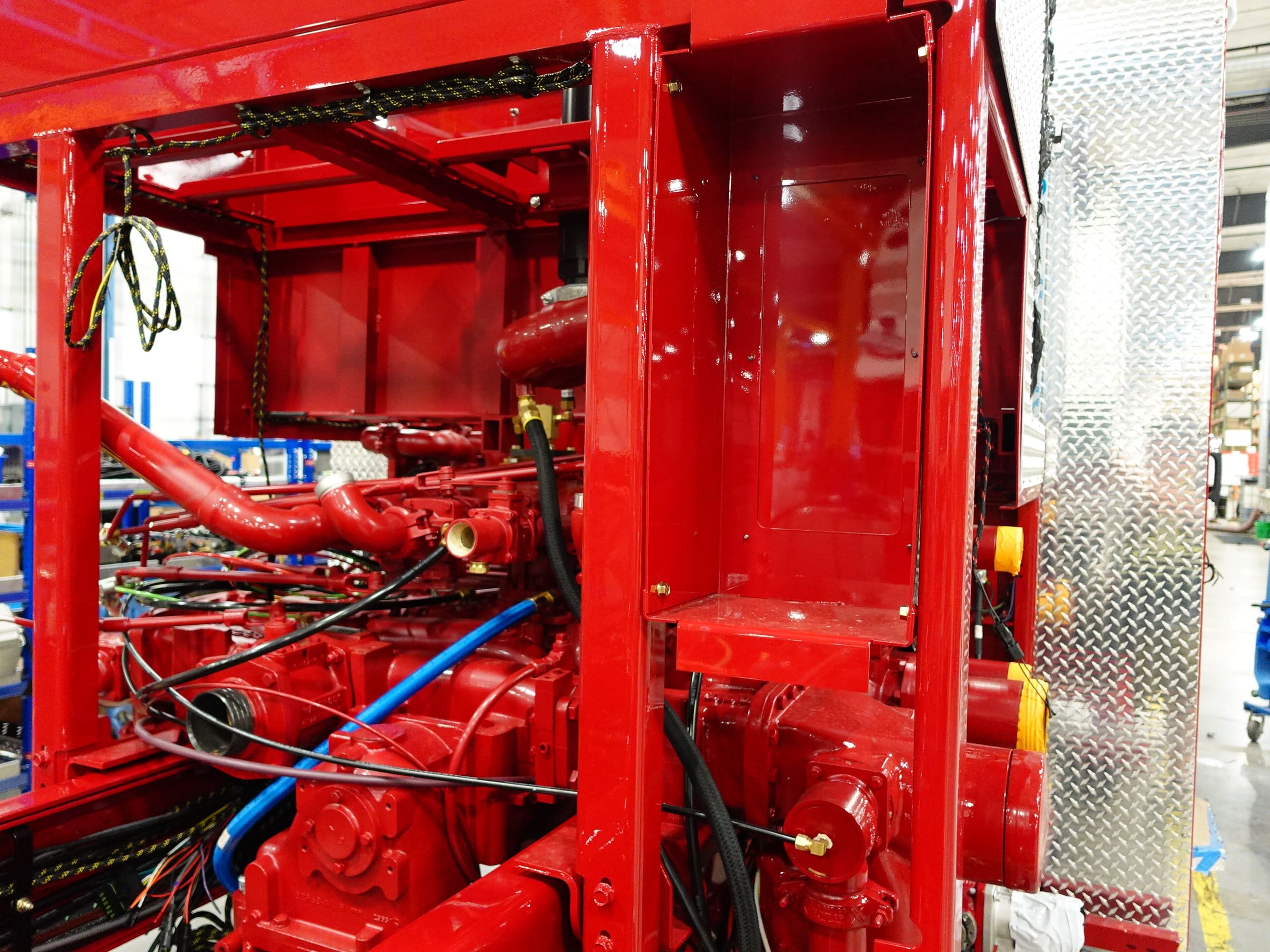

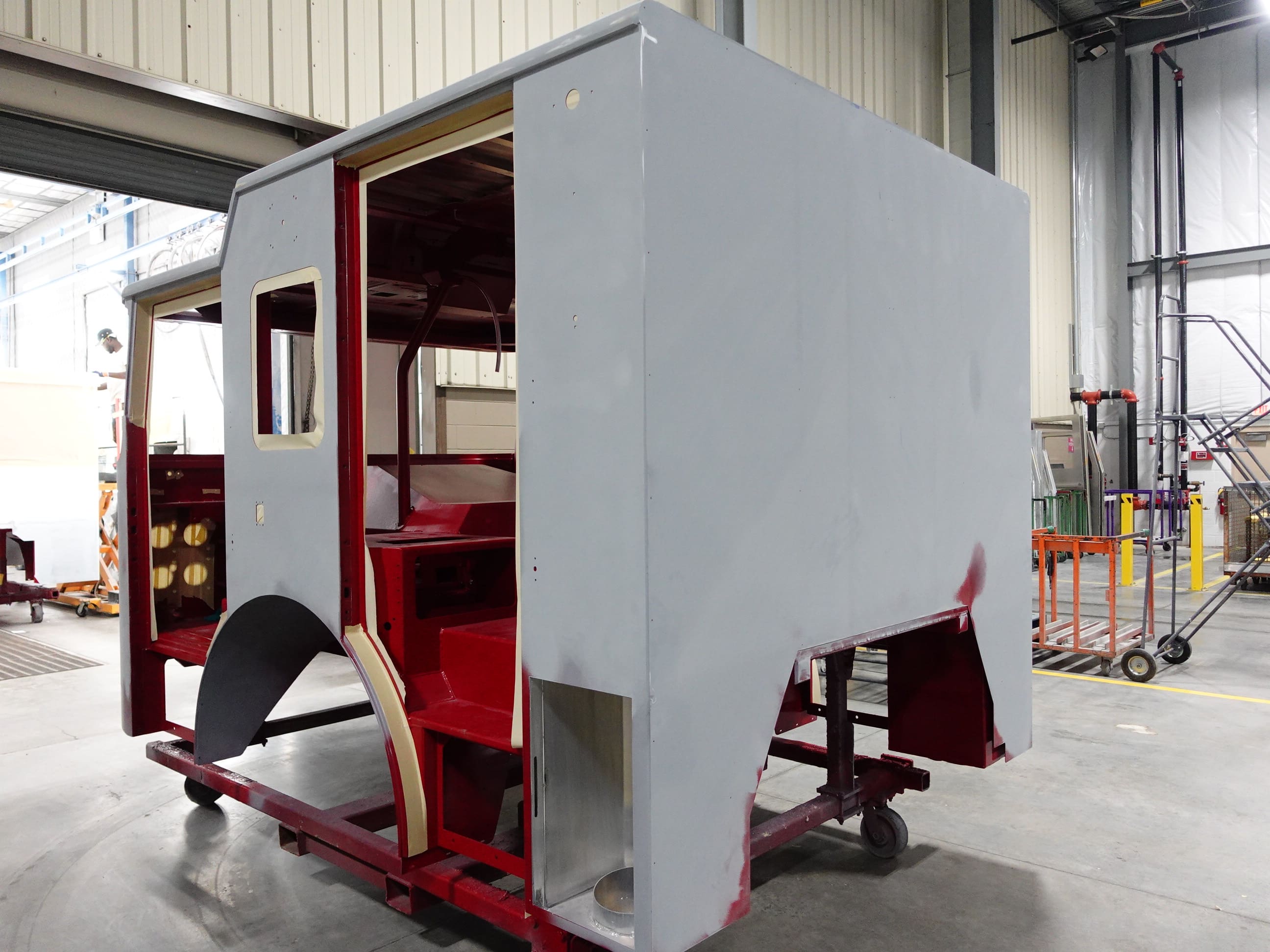

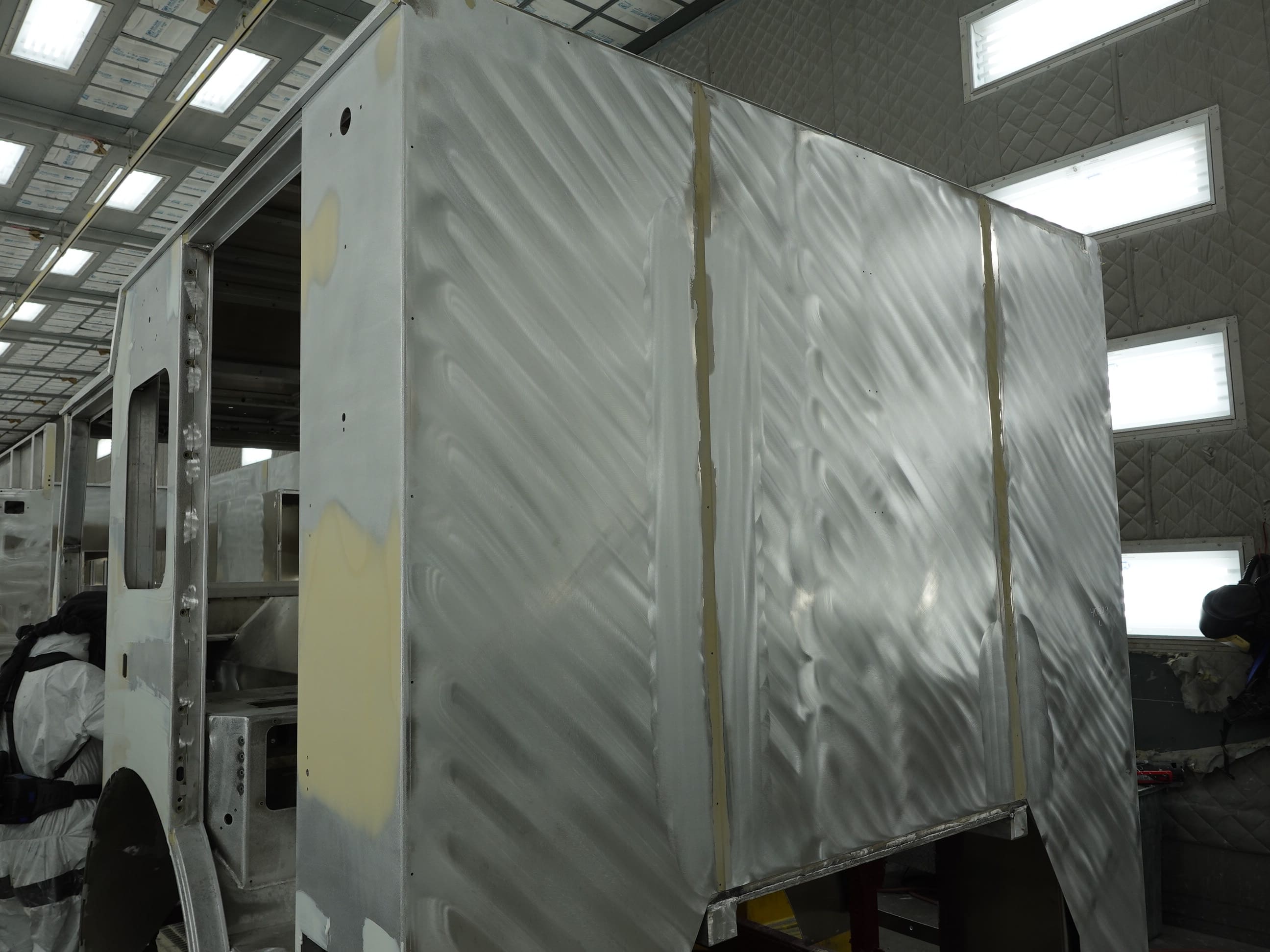

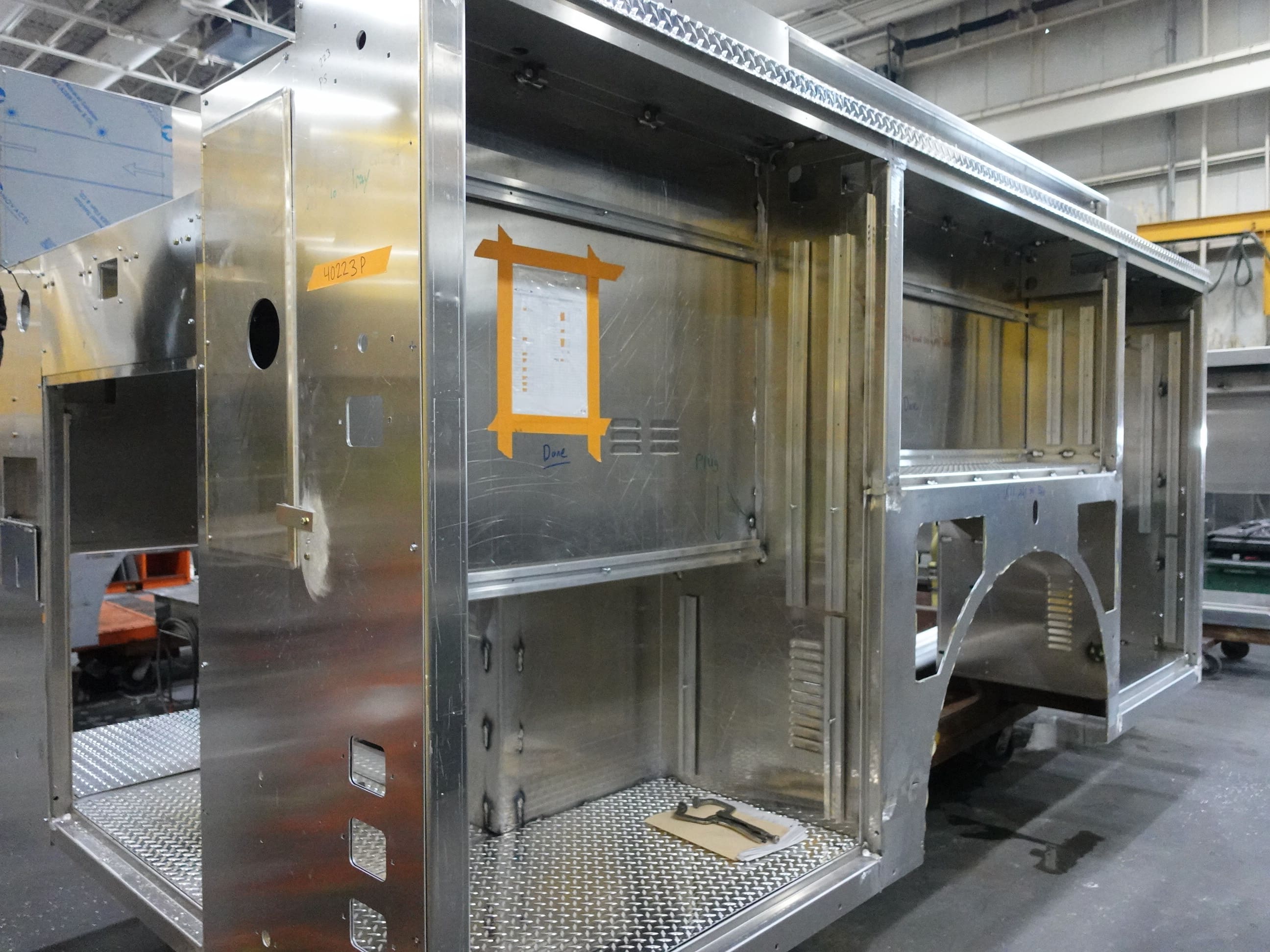

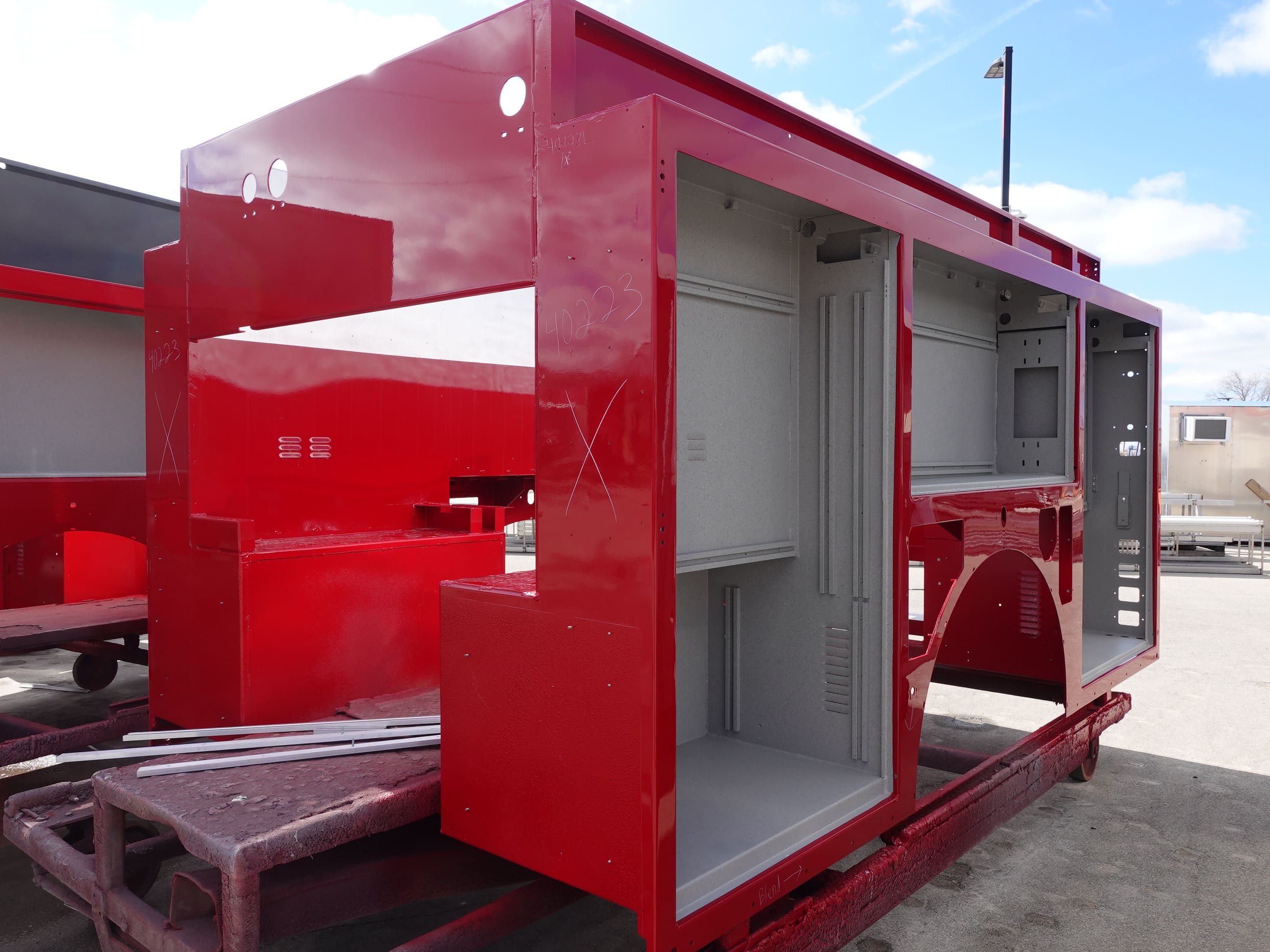

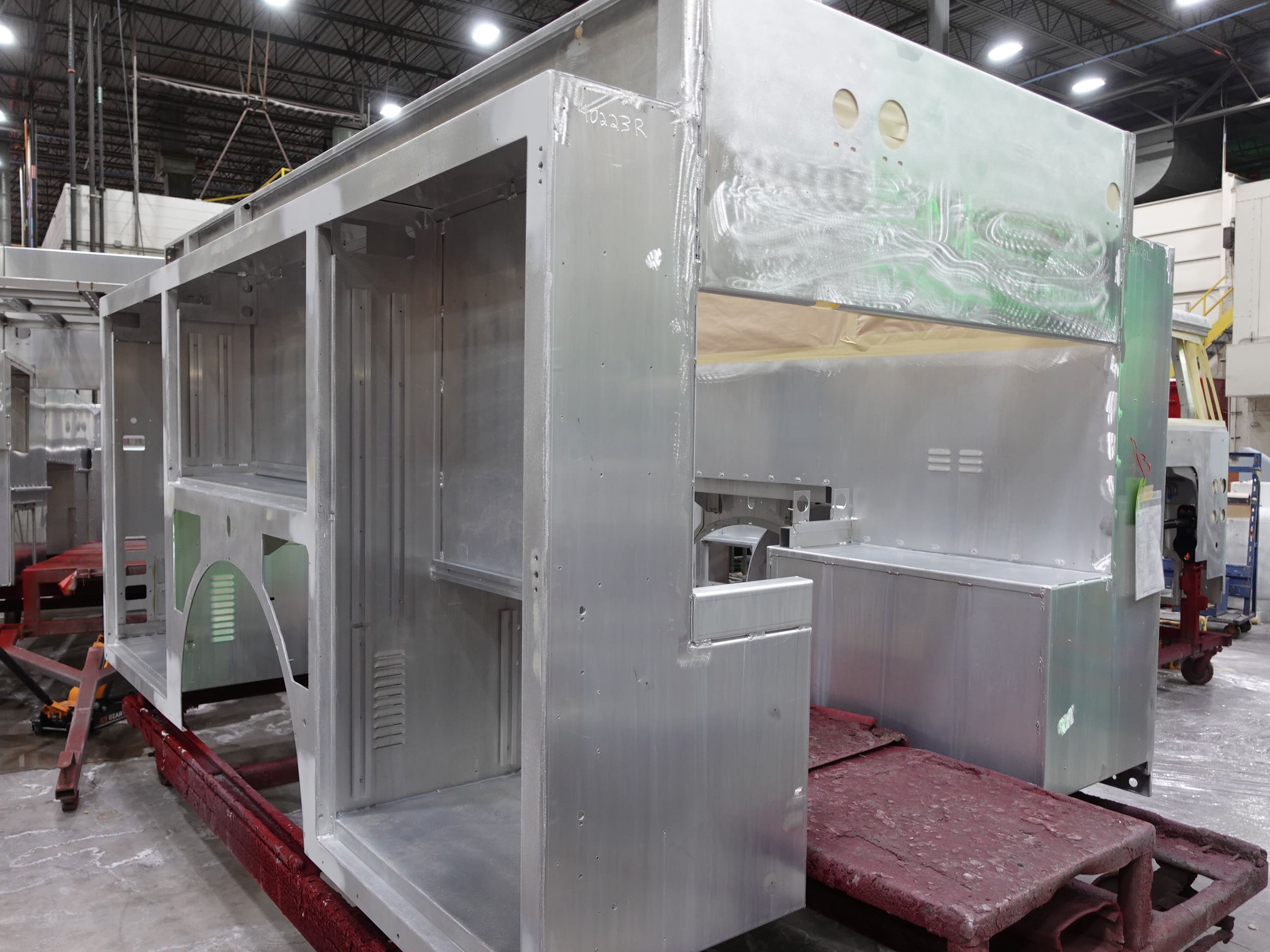

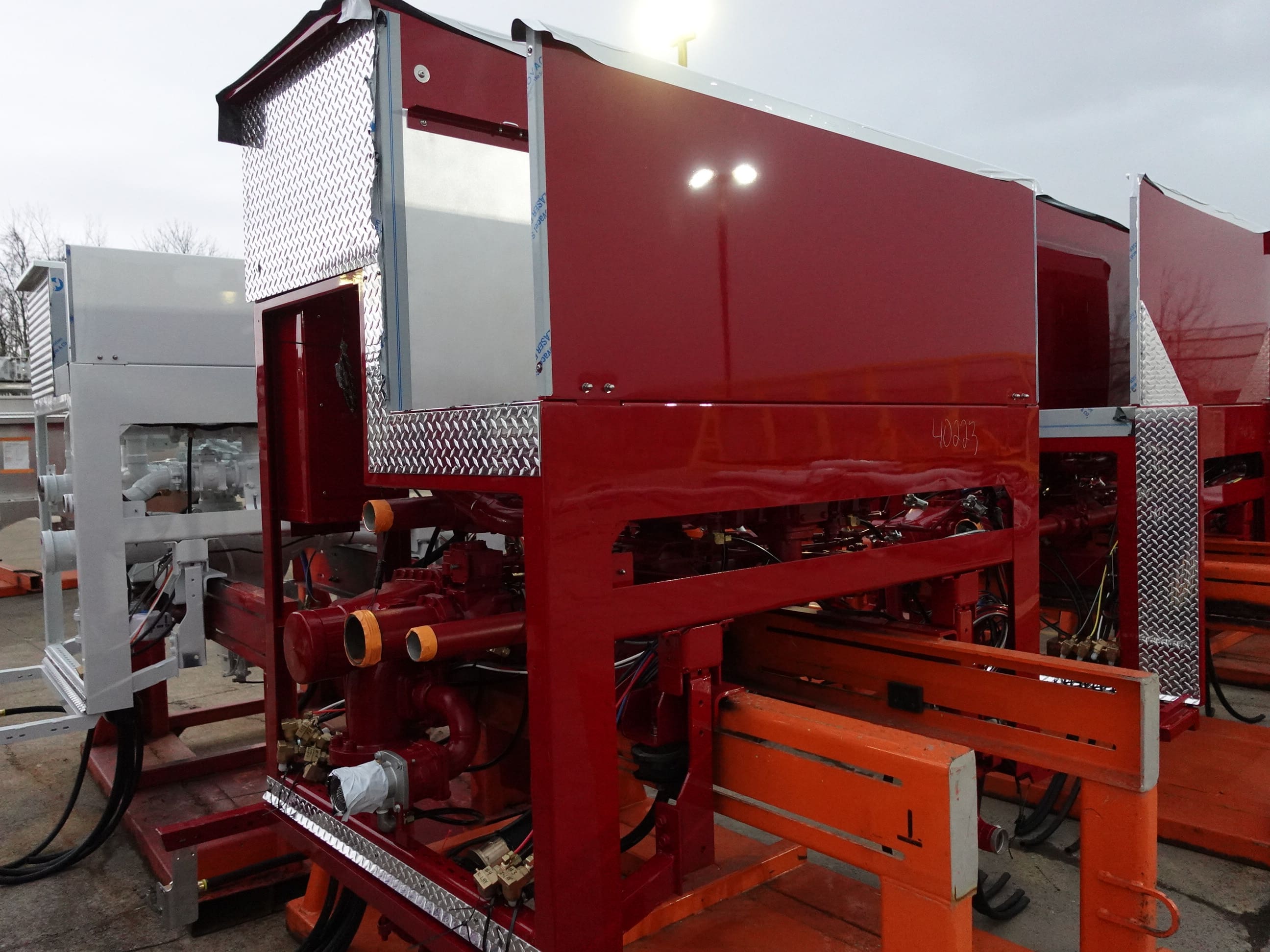

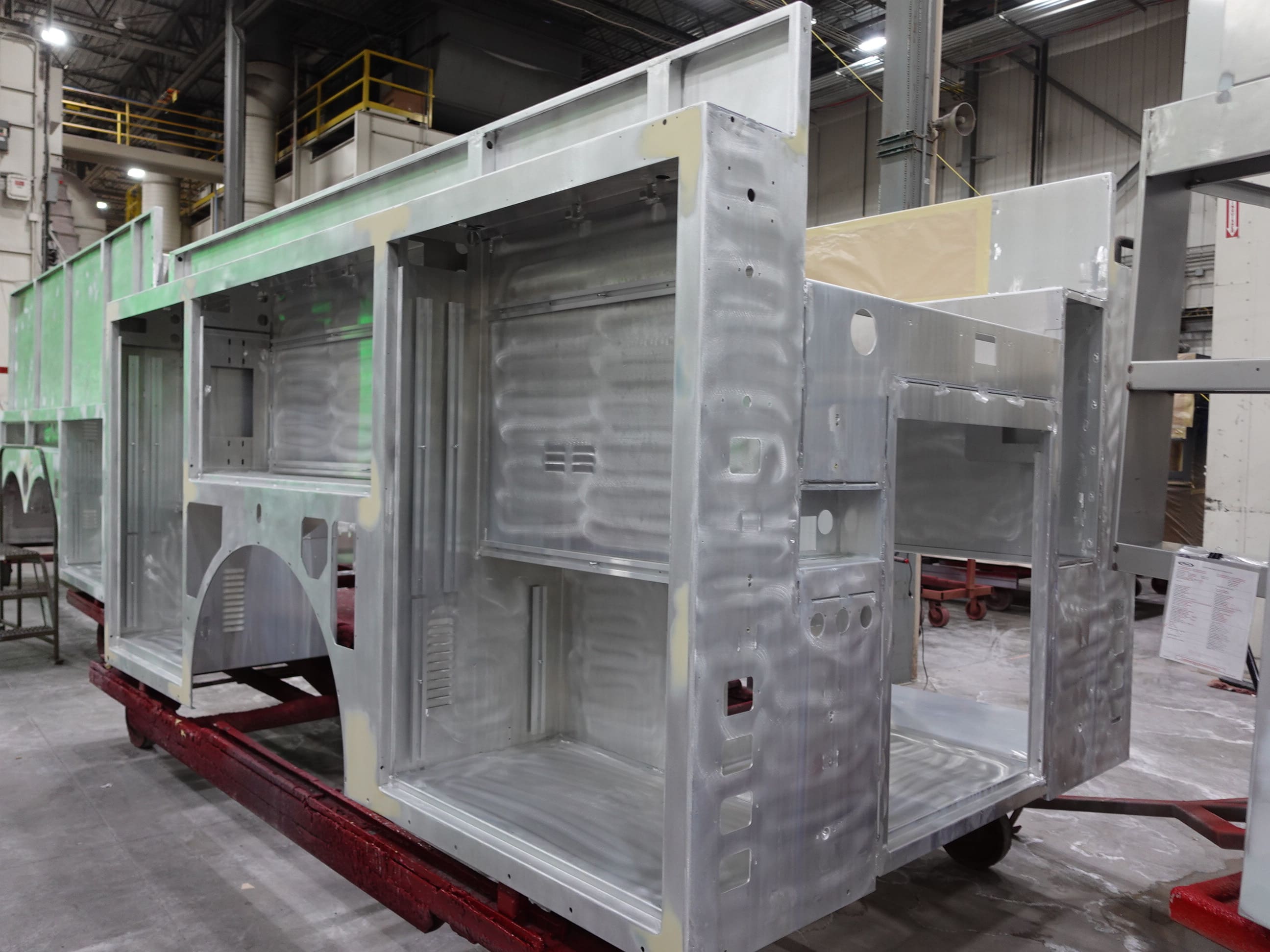

In this report, the cab completed initial assembly, the frame build continued, the pump house was staged, and the body completed the paint process.

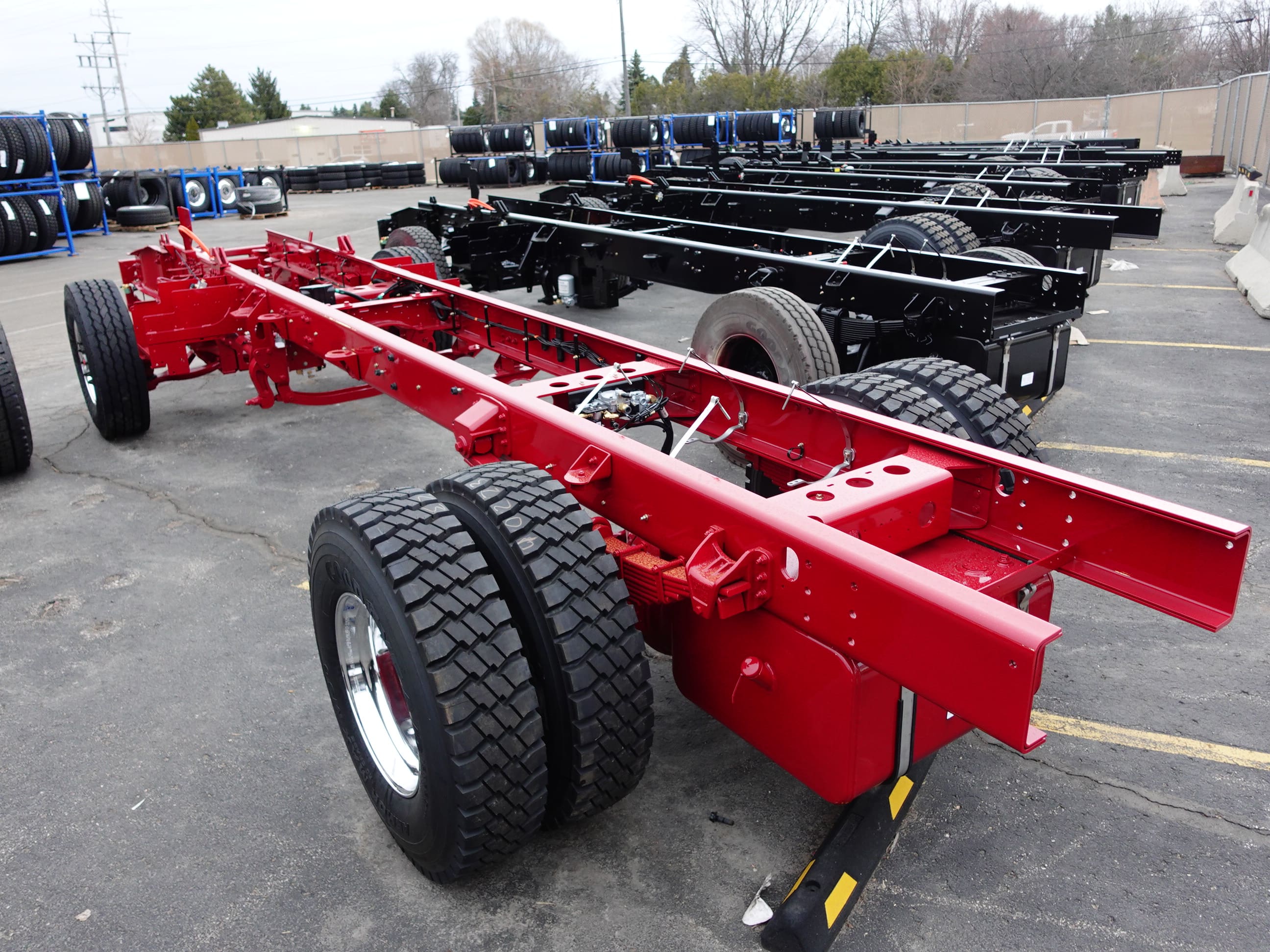

04-03-26

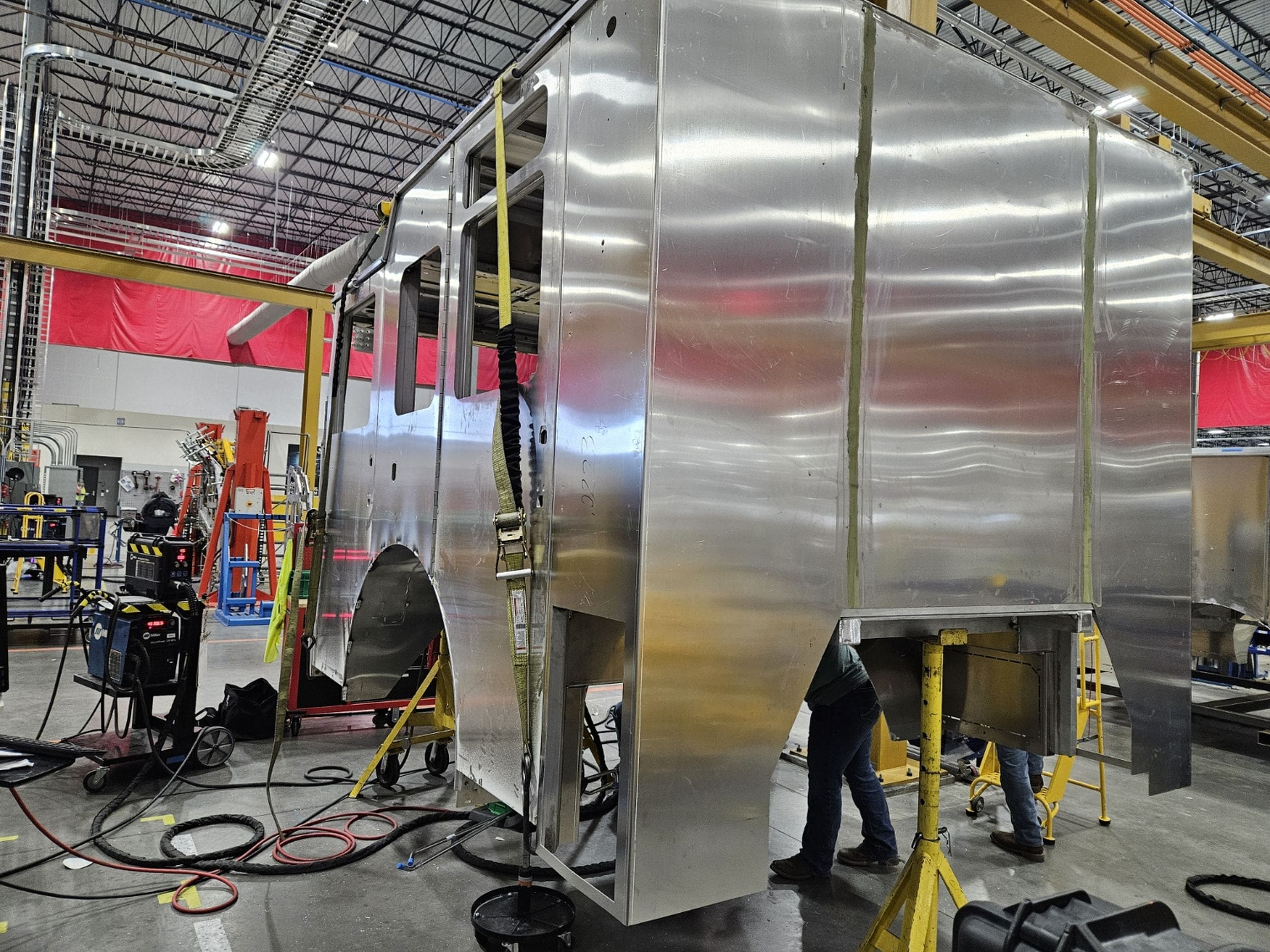

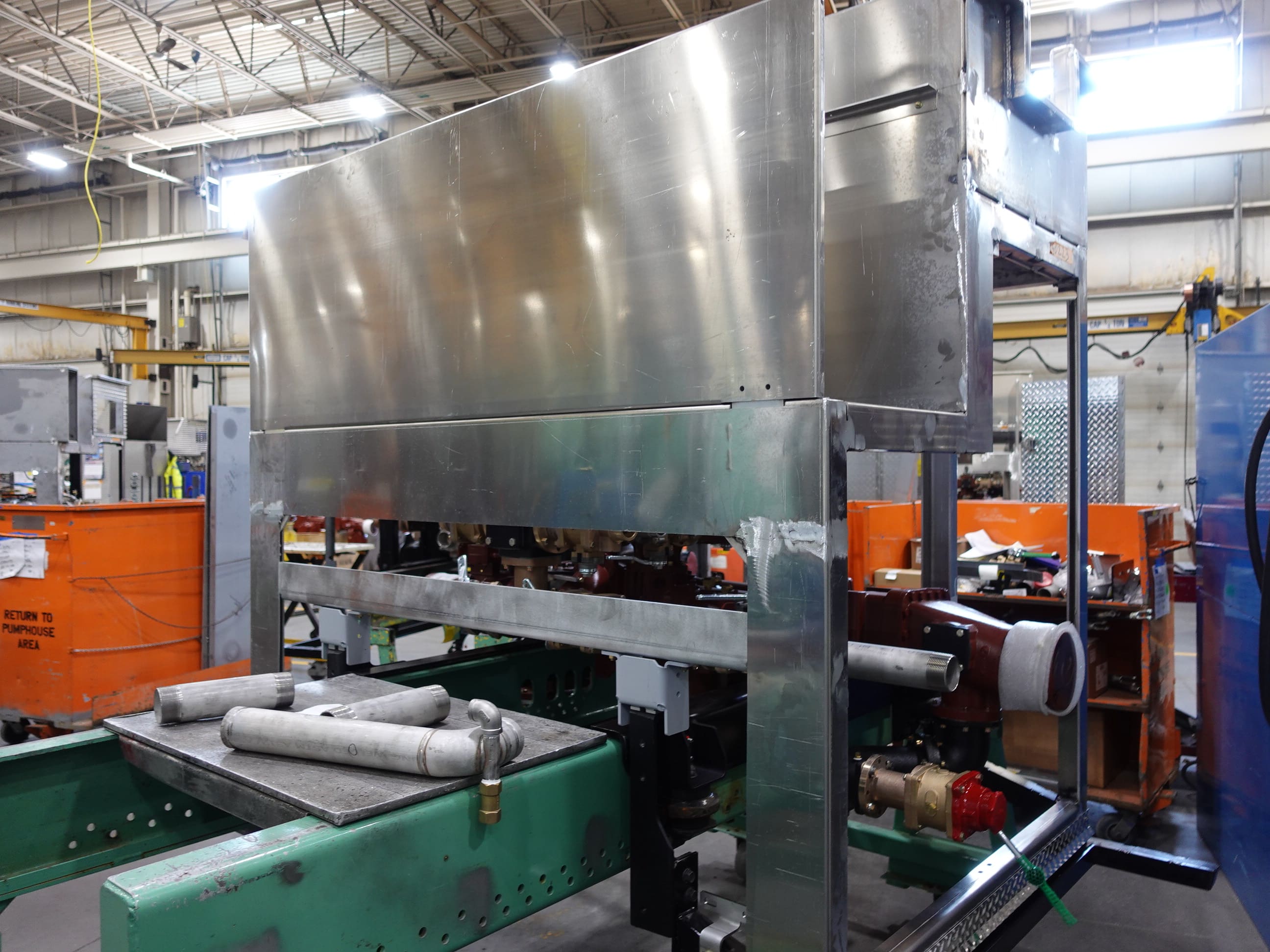

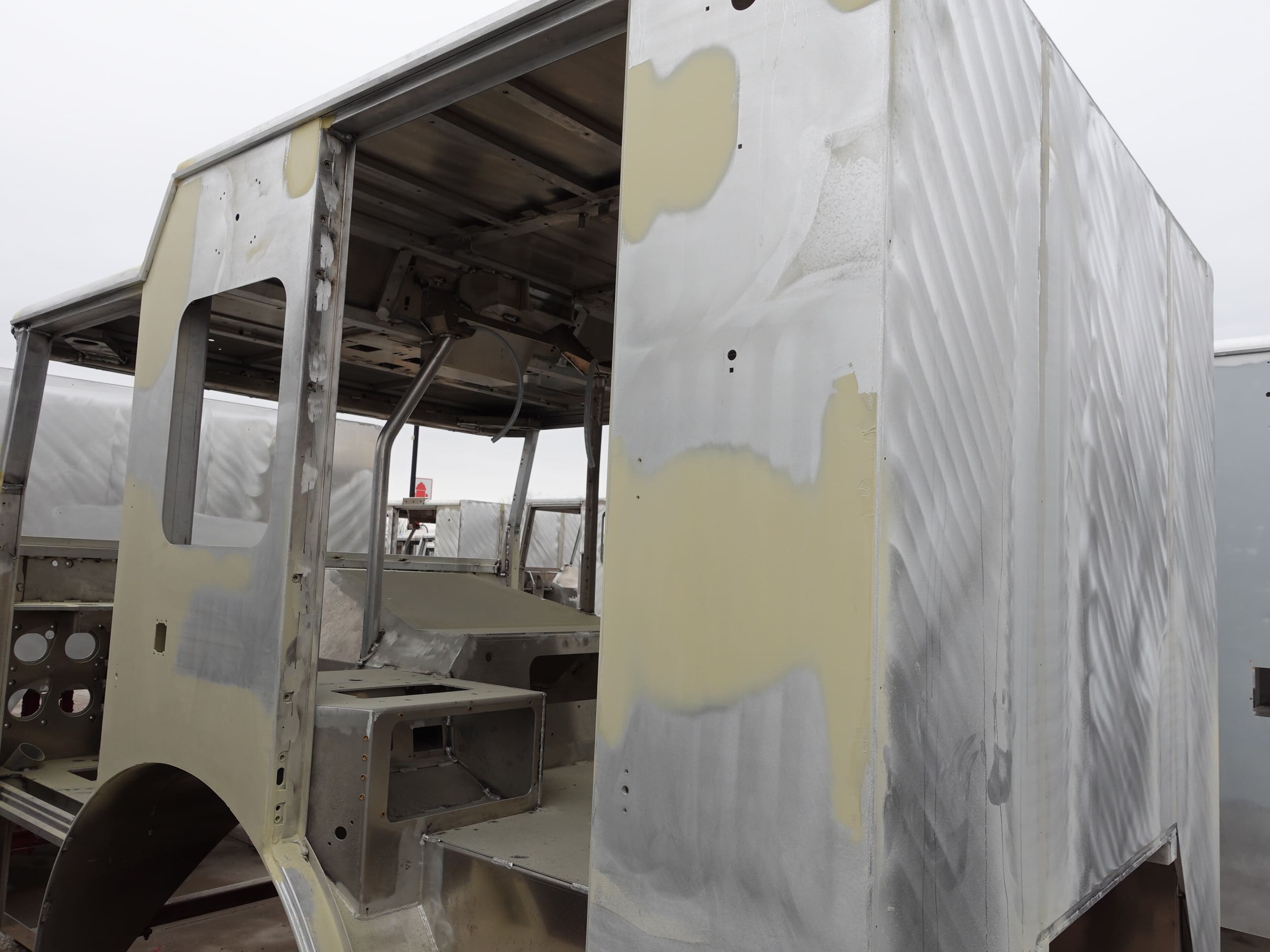

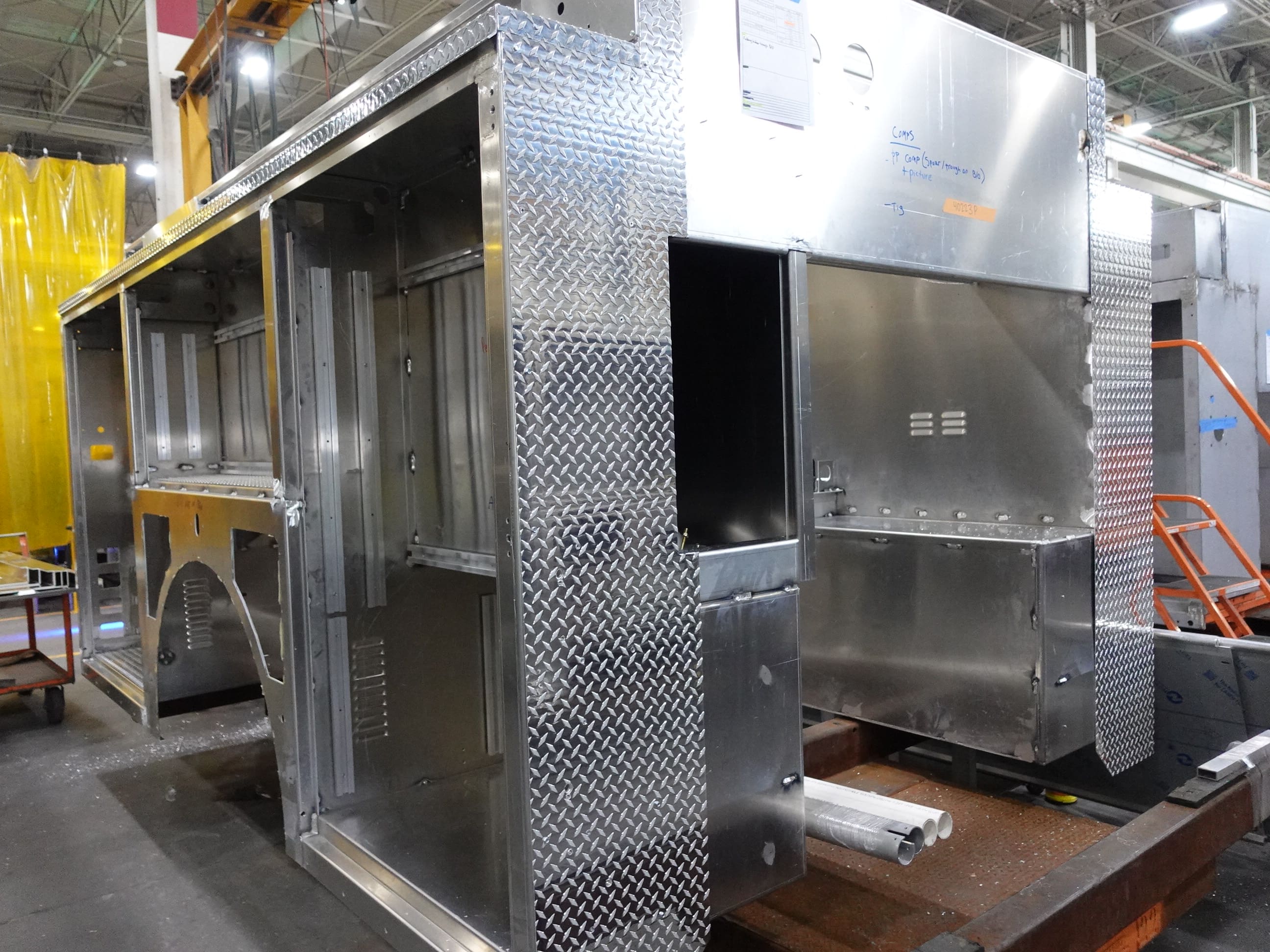

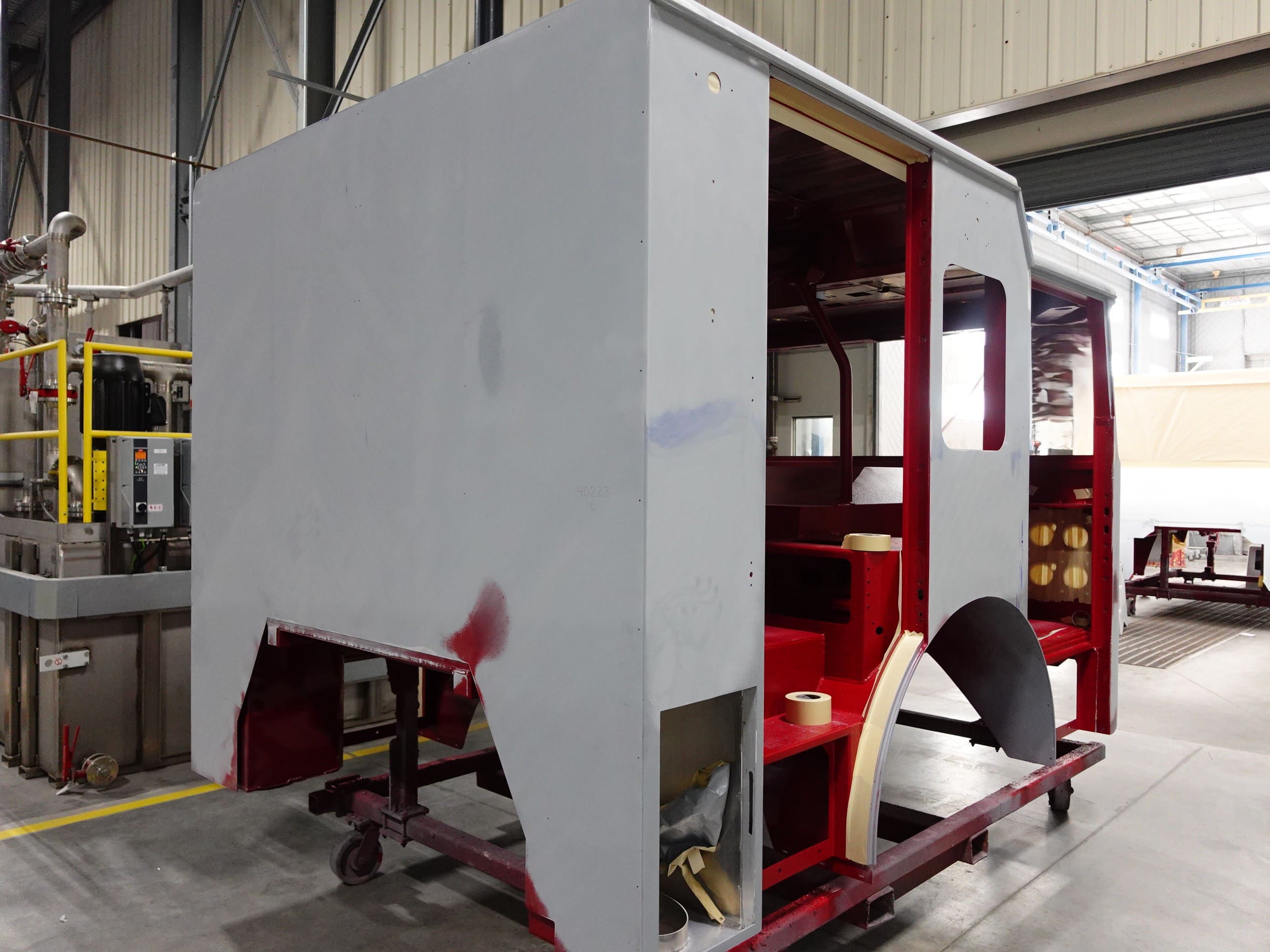

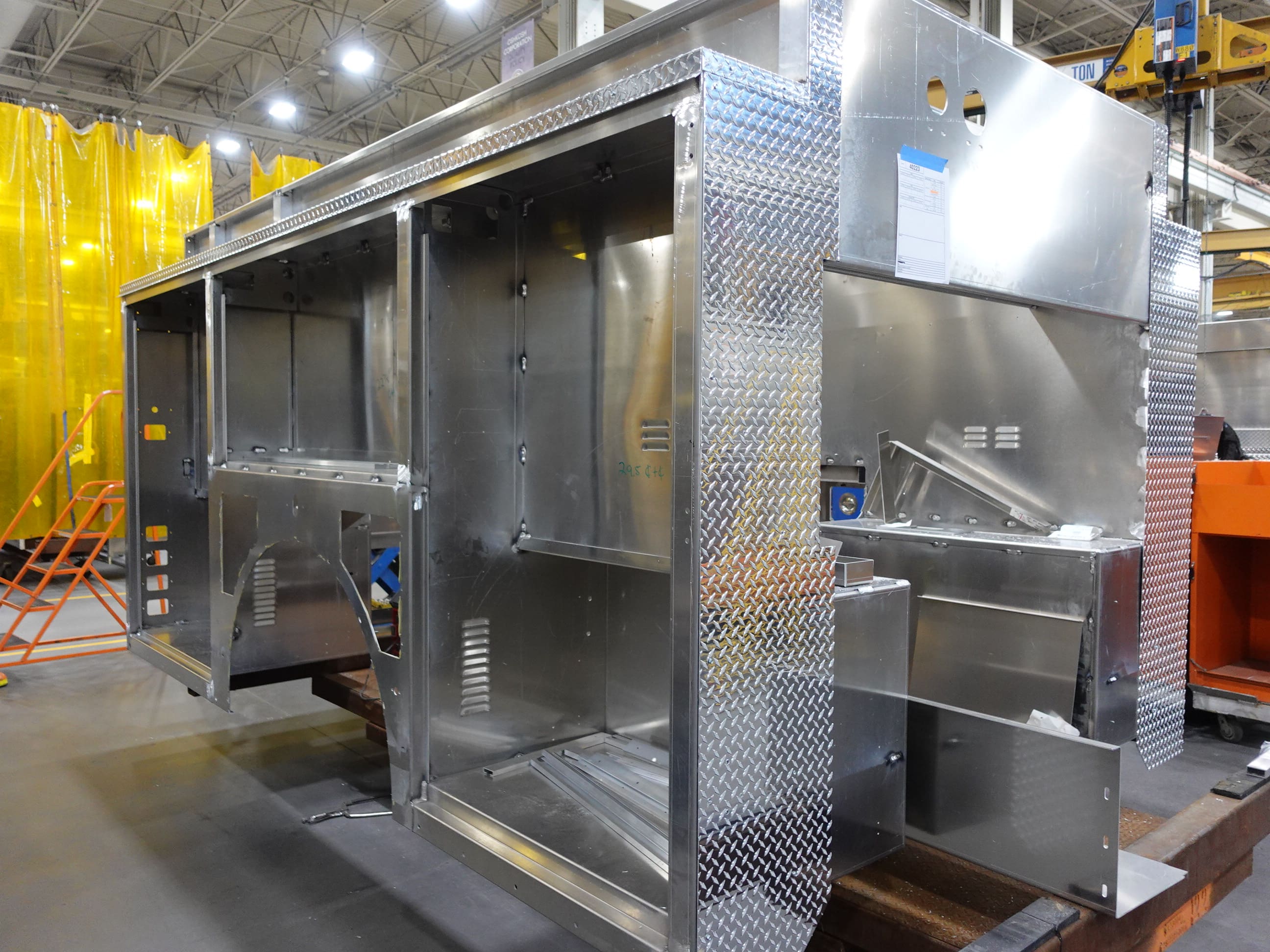

In this report, the cab completed paint and began initial assembly, the frame build began, the pump house completed initial assembly, and the body completed fabrication and began the paint process.
03-20-26
In this report, the cab continued the paint process, the pump house began initial assembly, and the body continued the fabrication process.
02-27-26

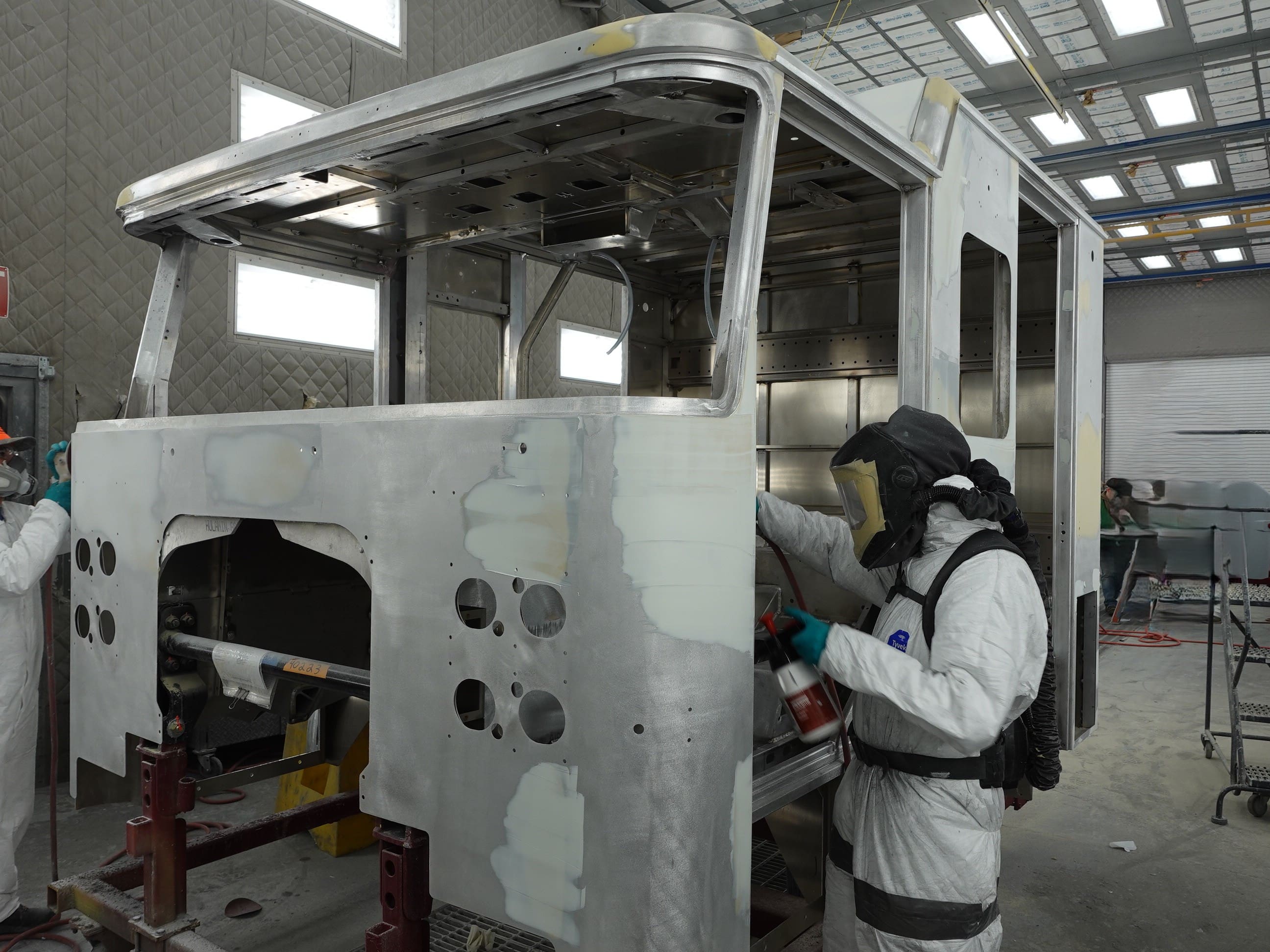

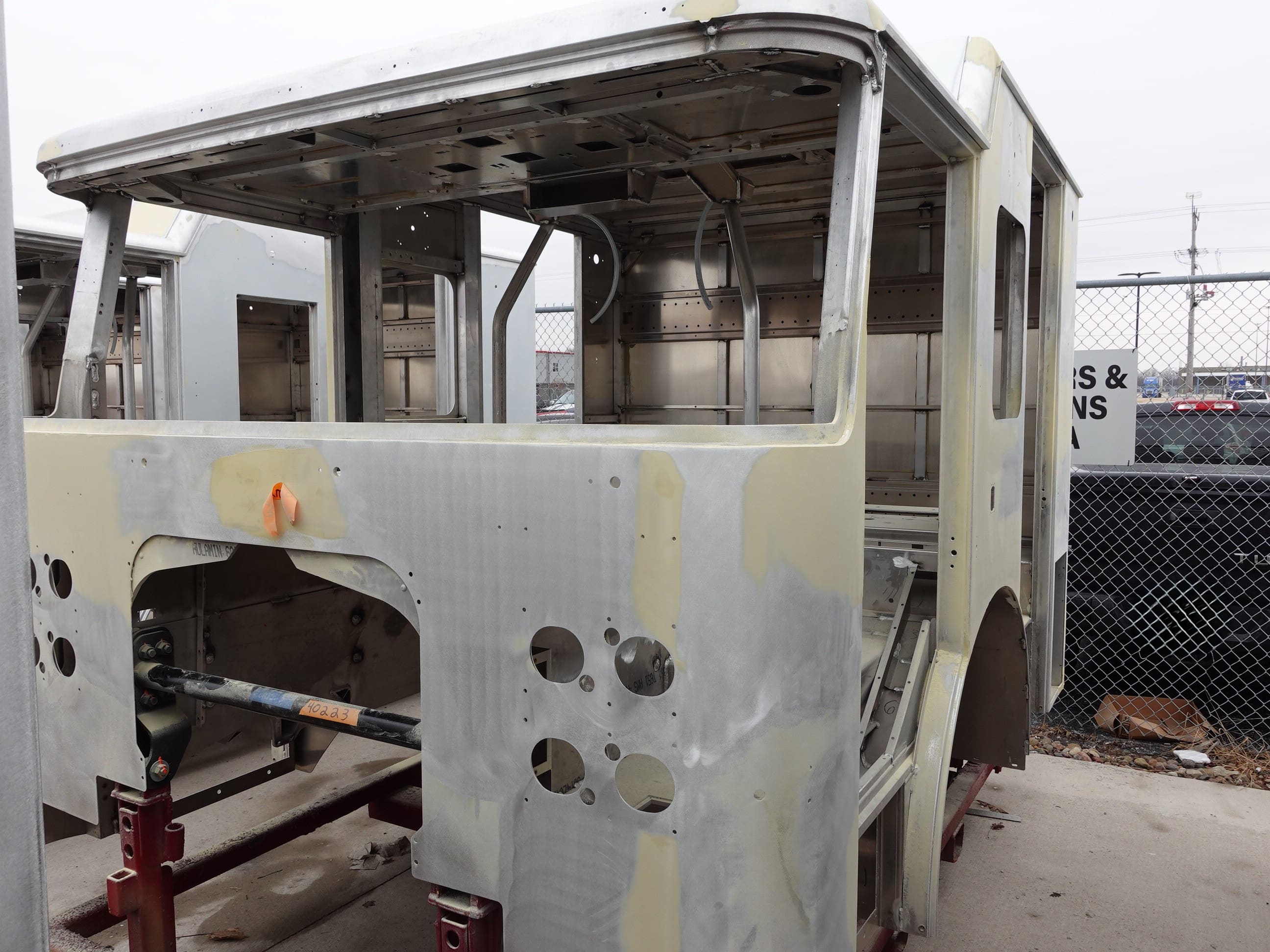

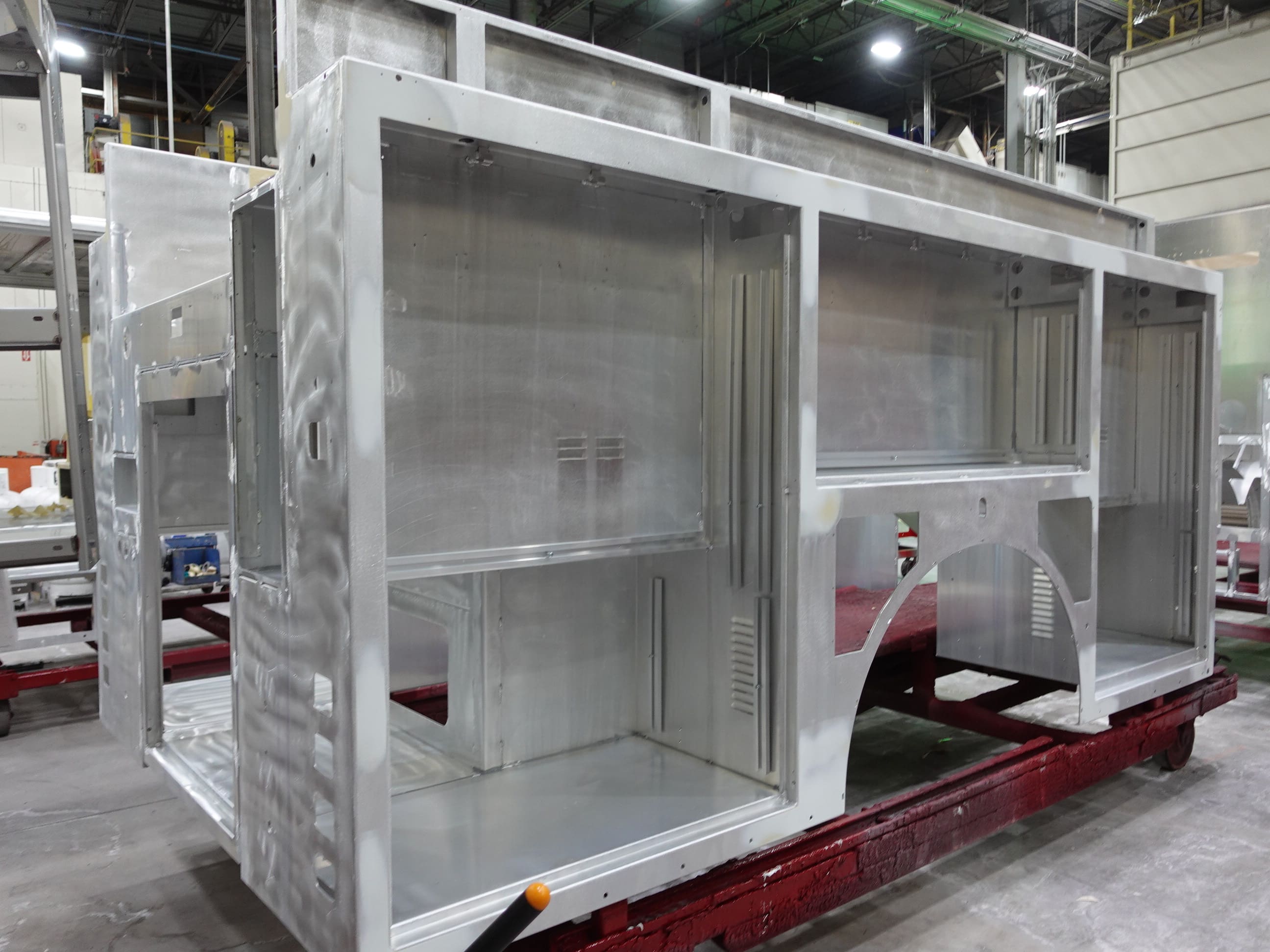

In this report, the cab completed fabrication and is queued to begin the paint process.
02-13-26

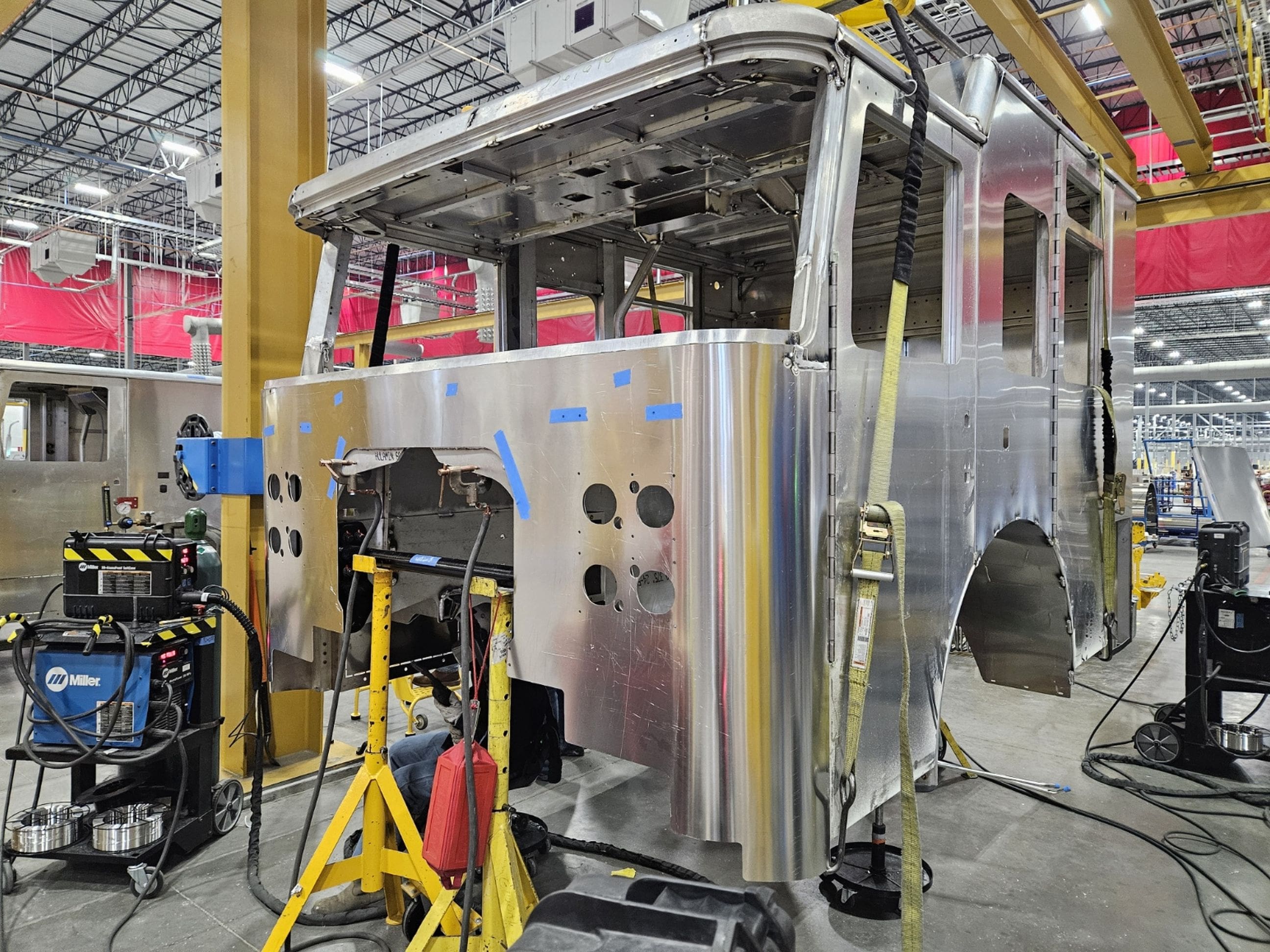

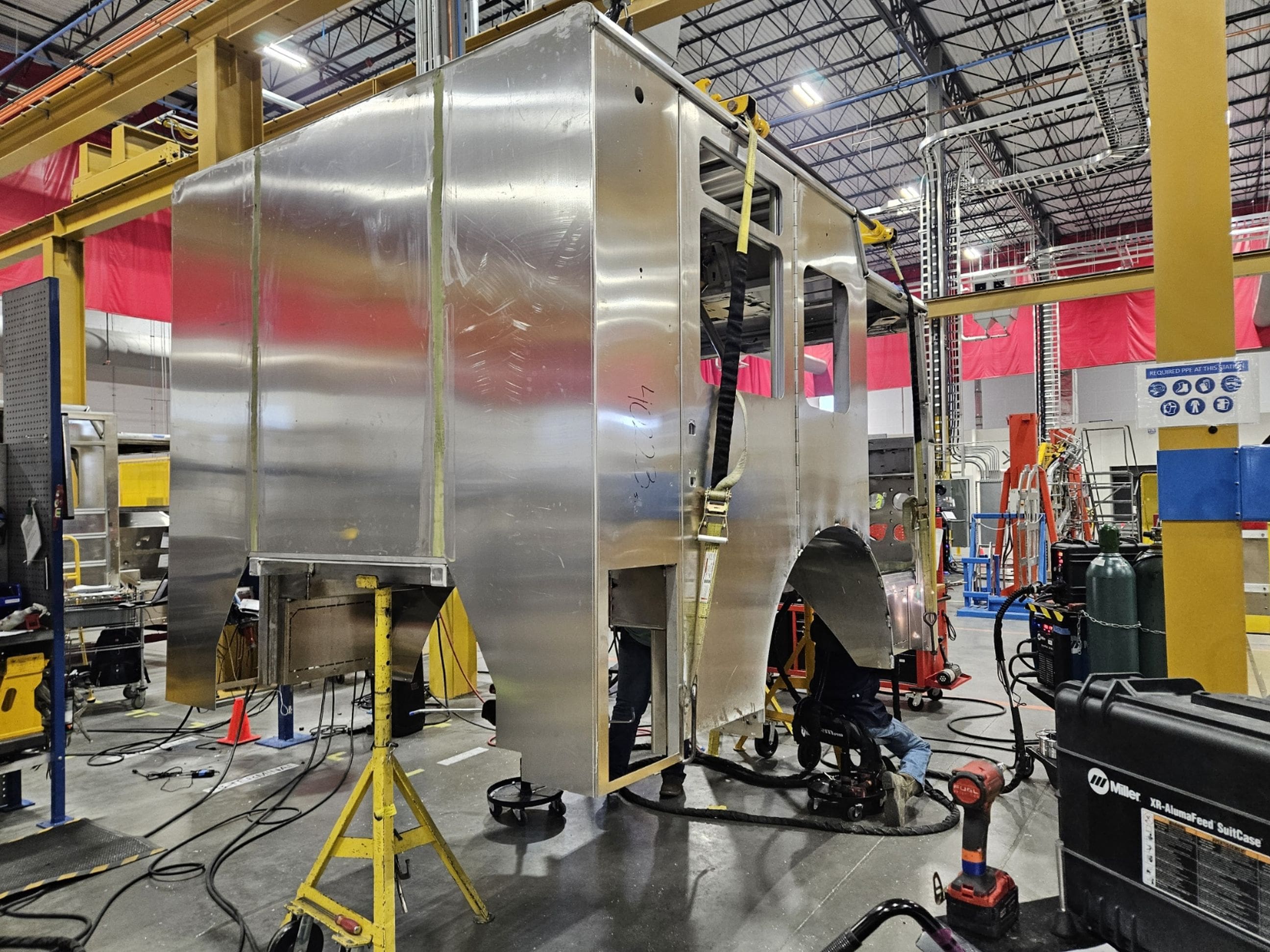

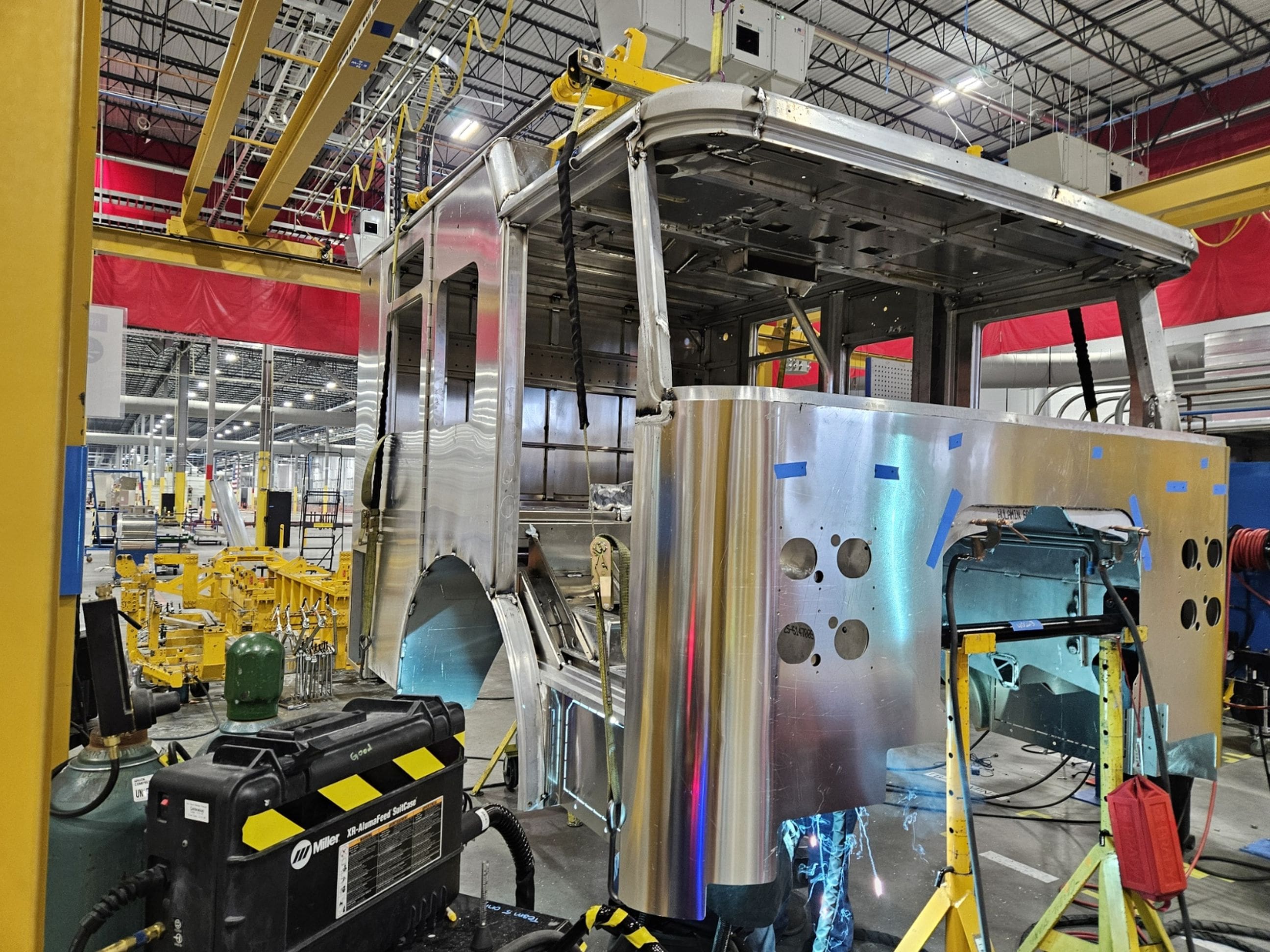

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
