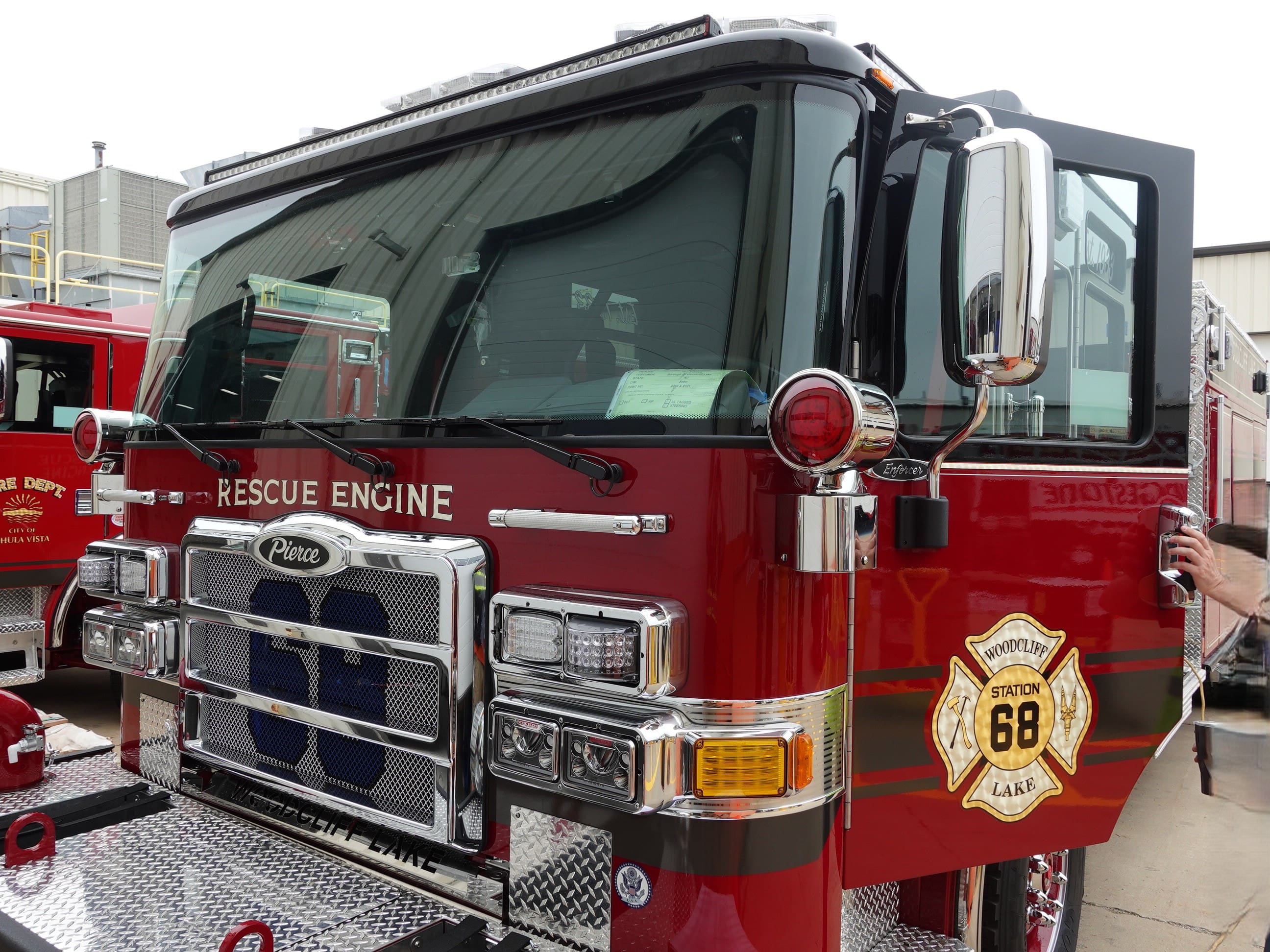

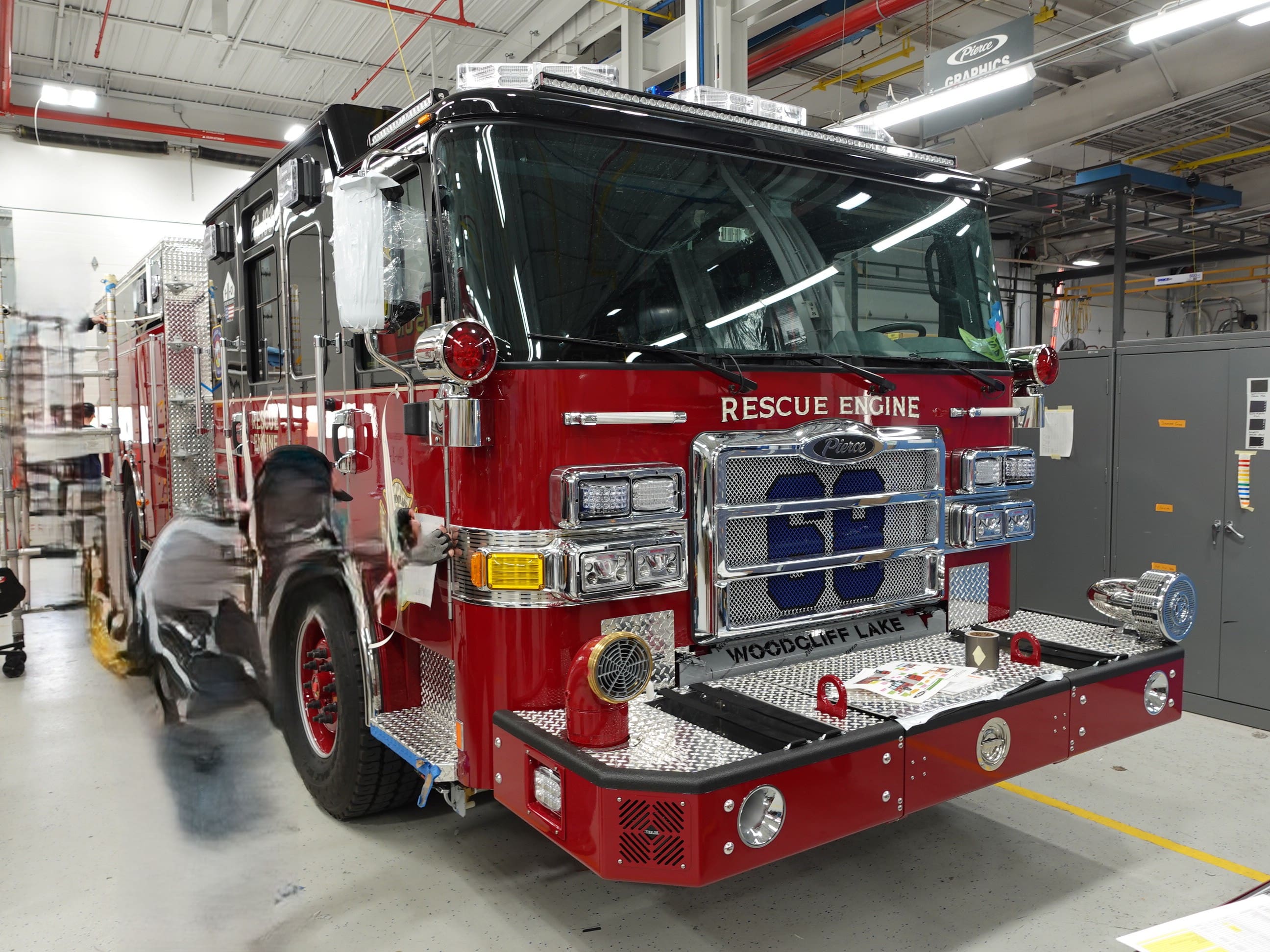

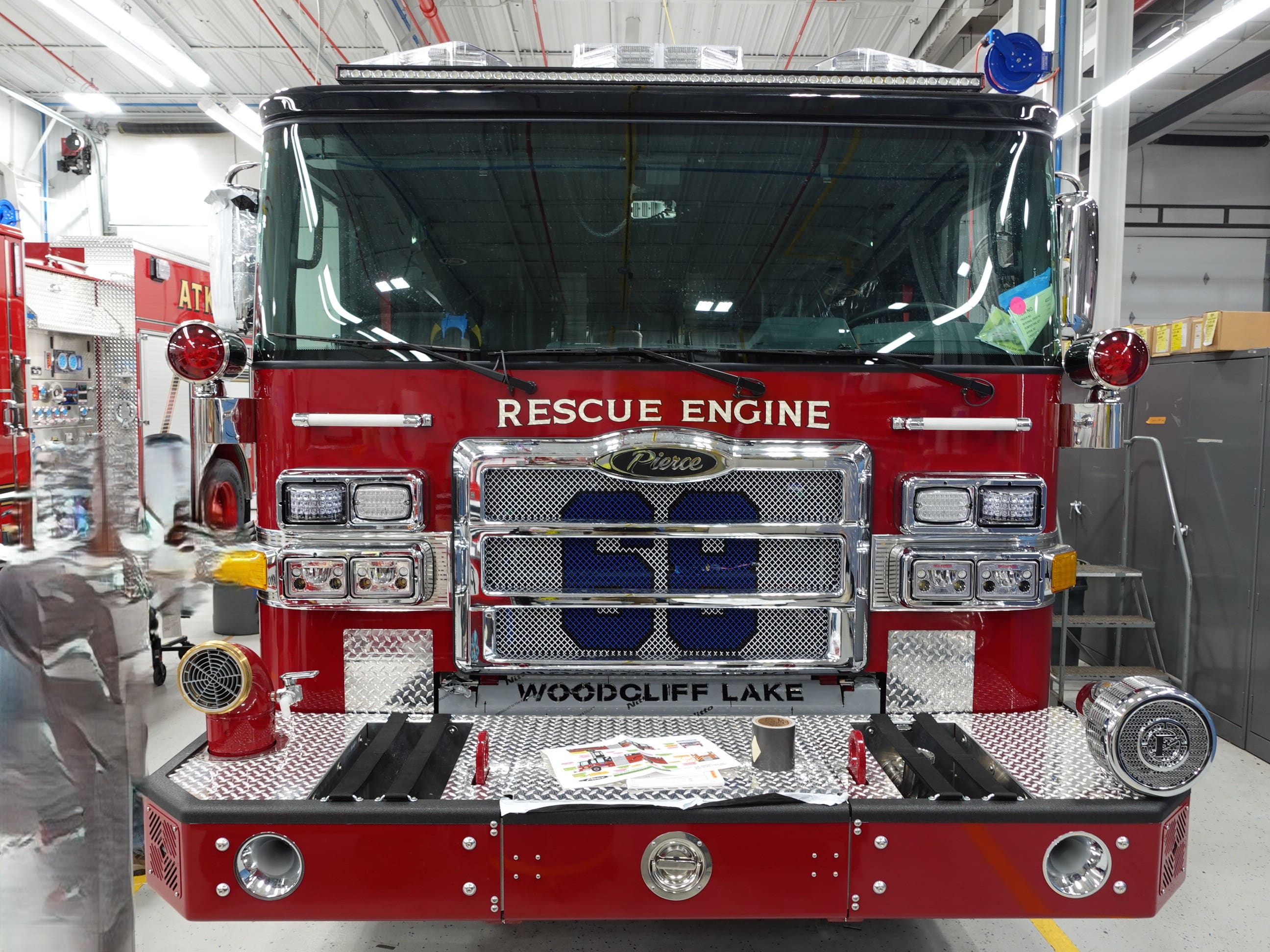

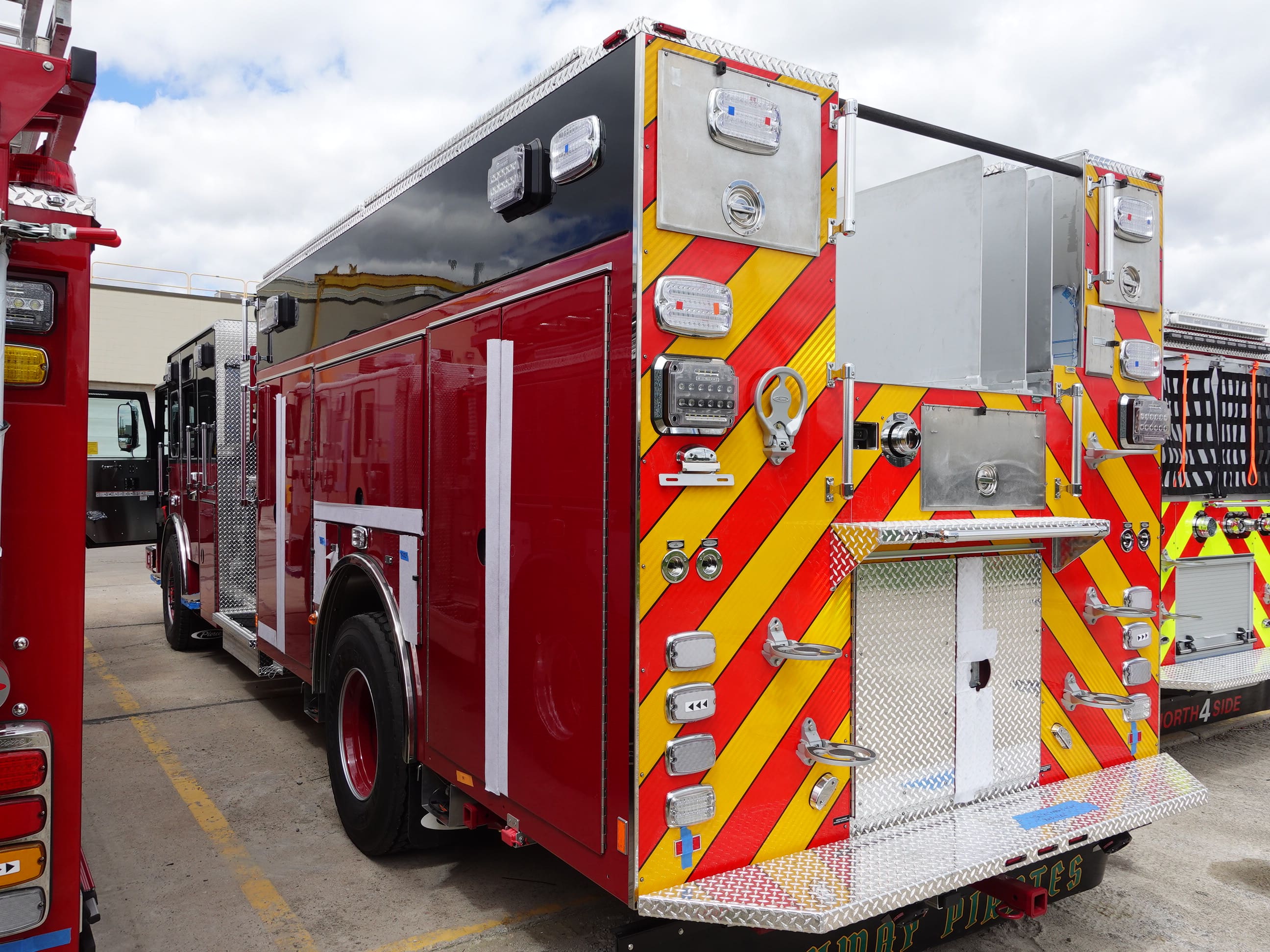

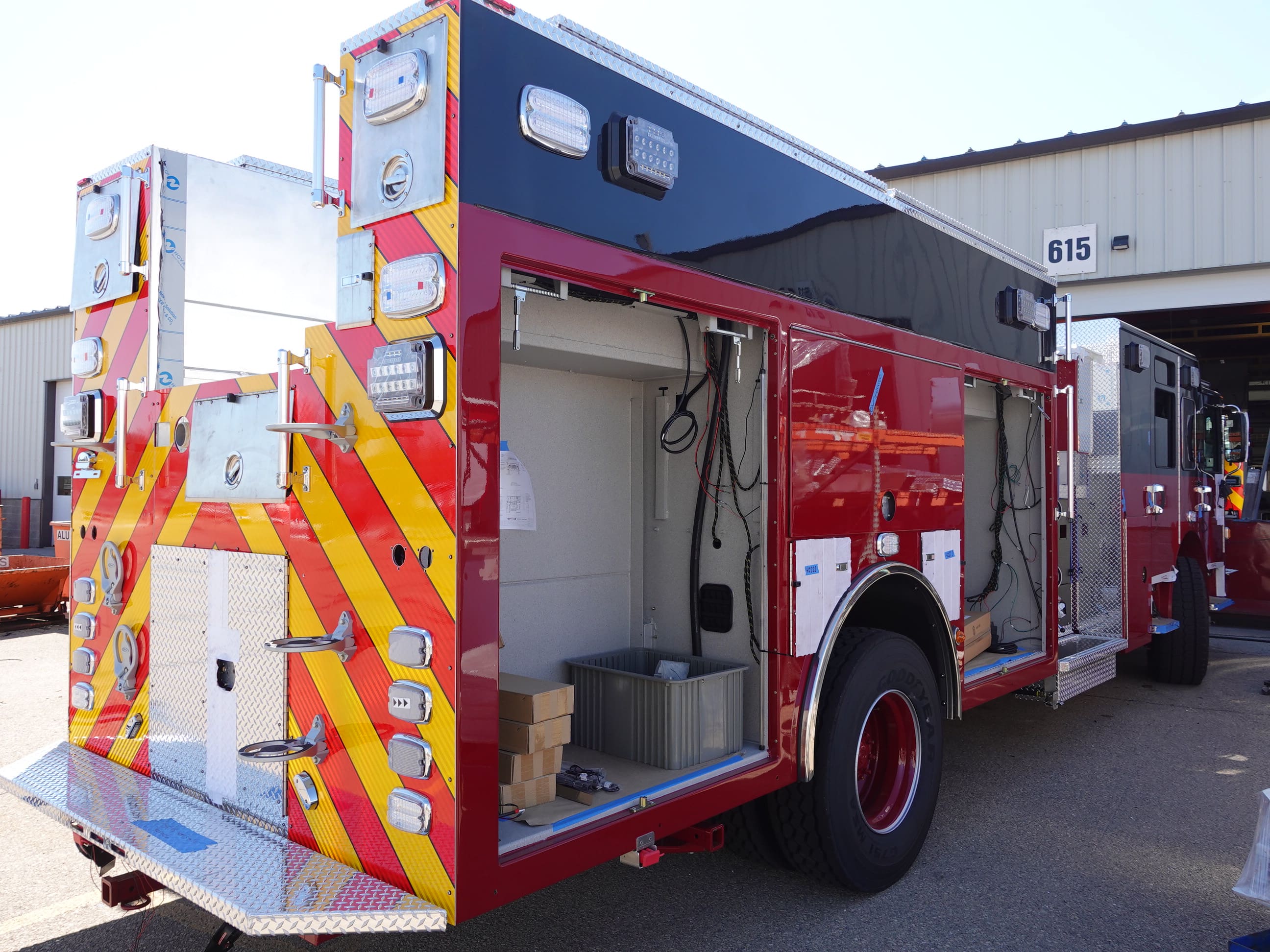

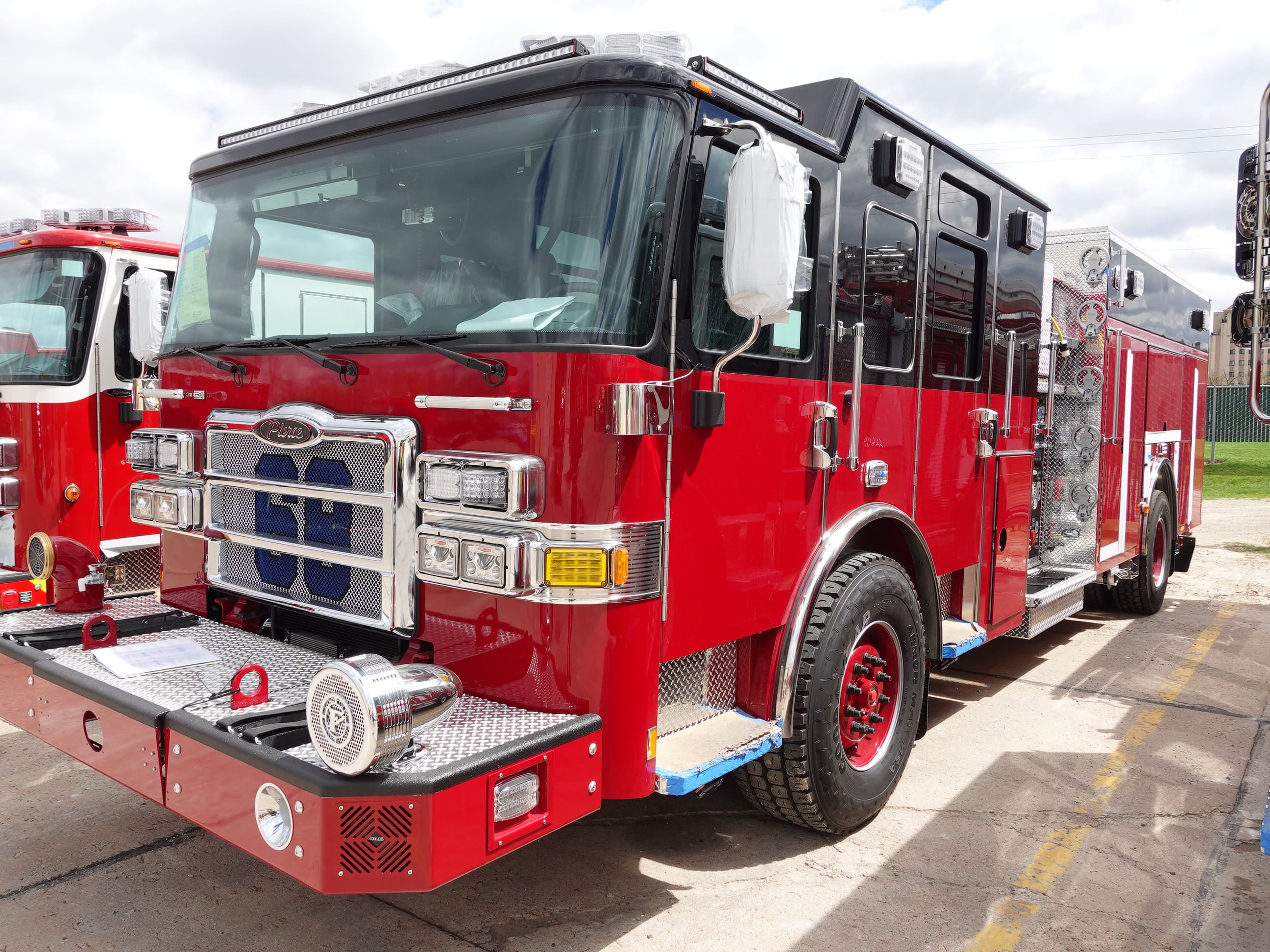

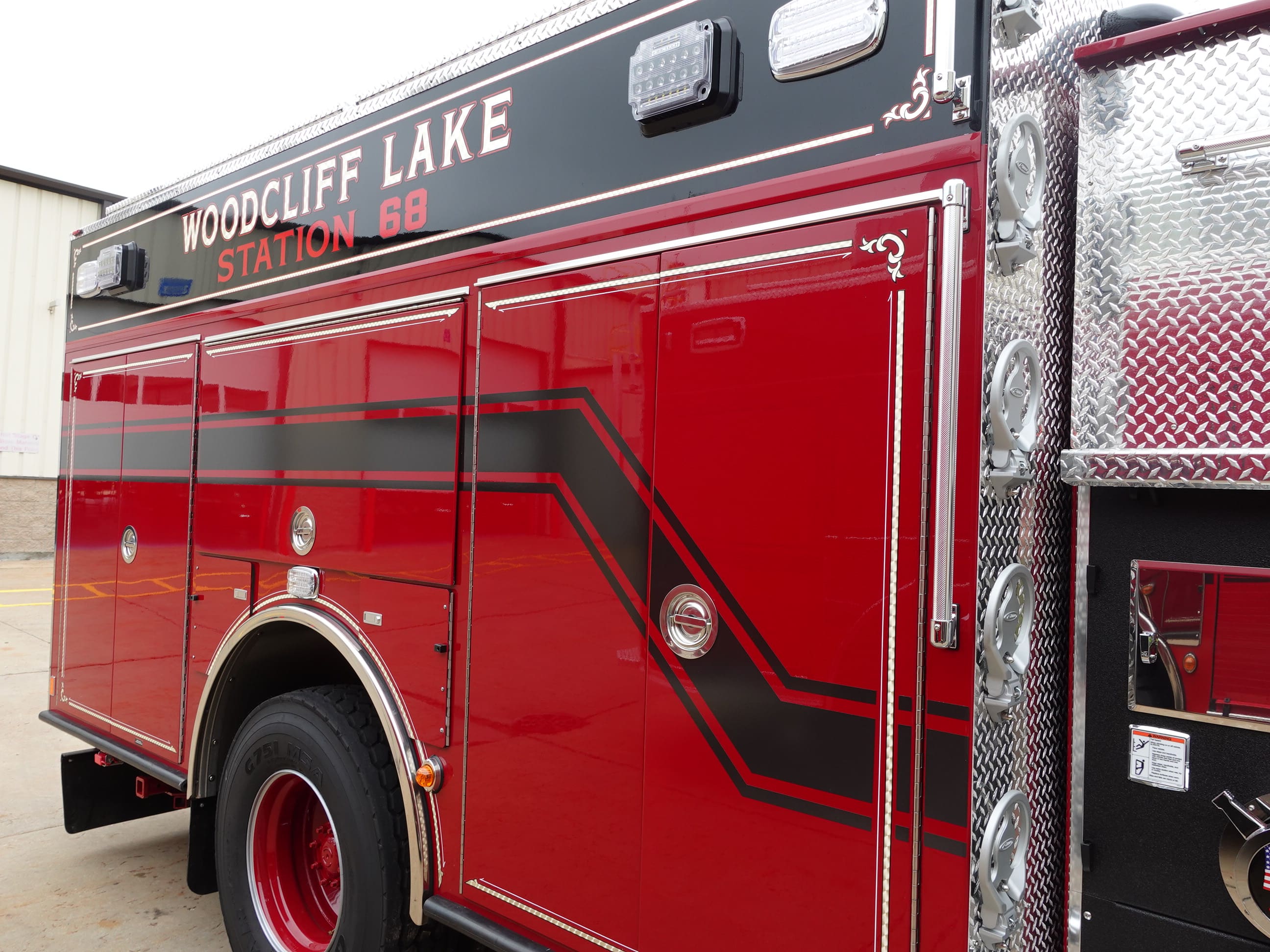

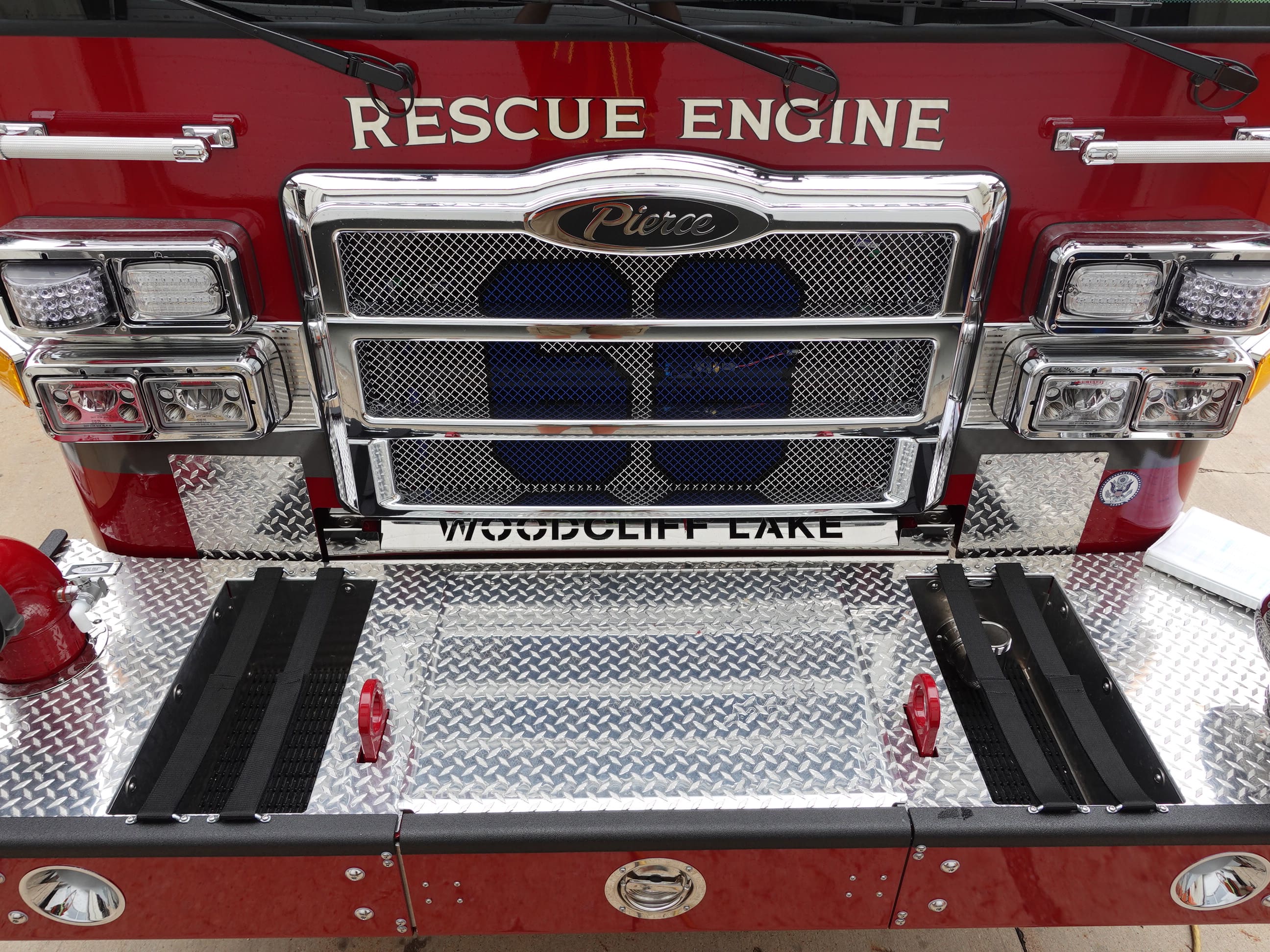

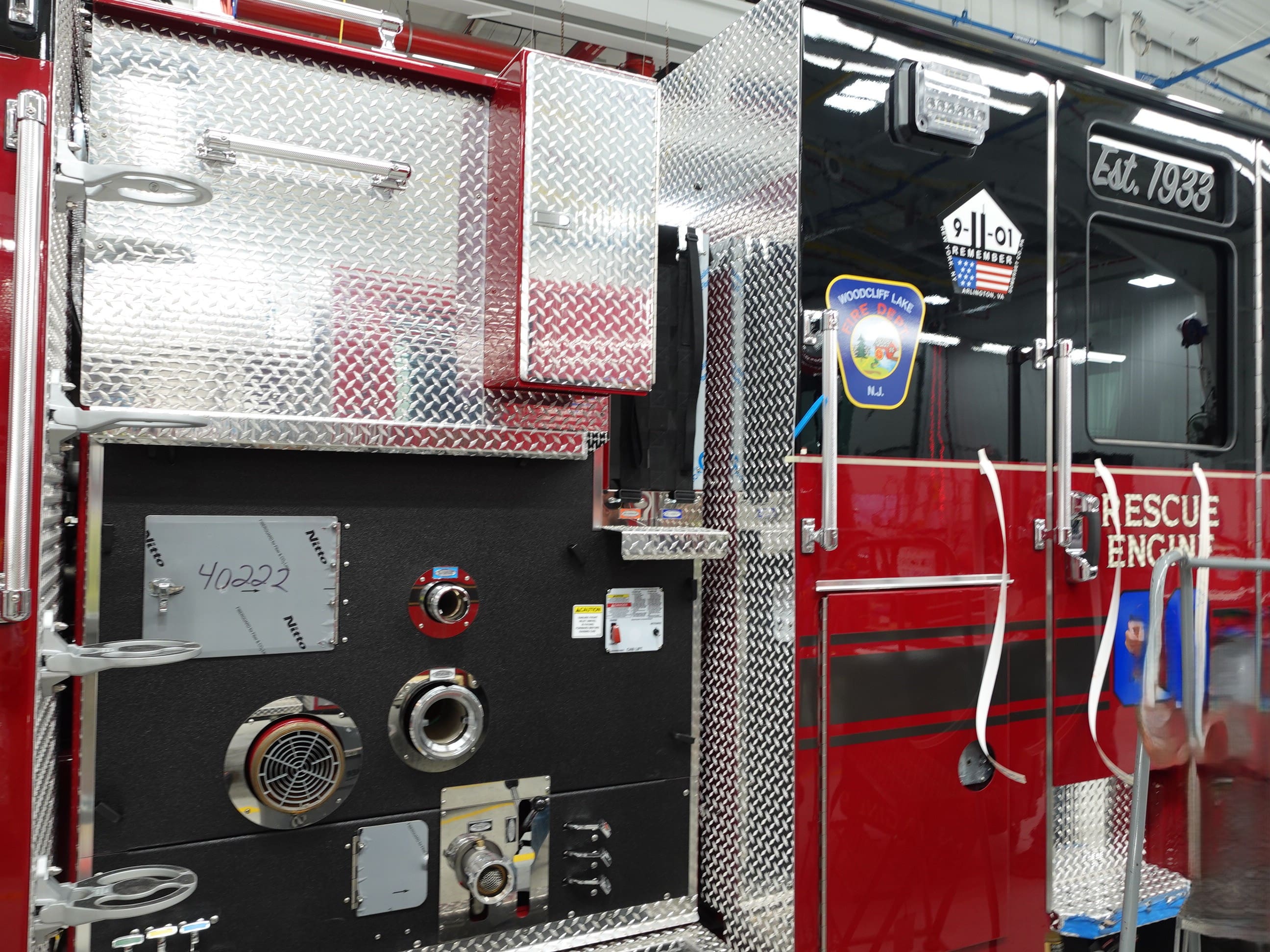

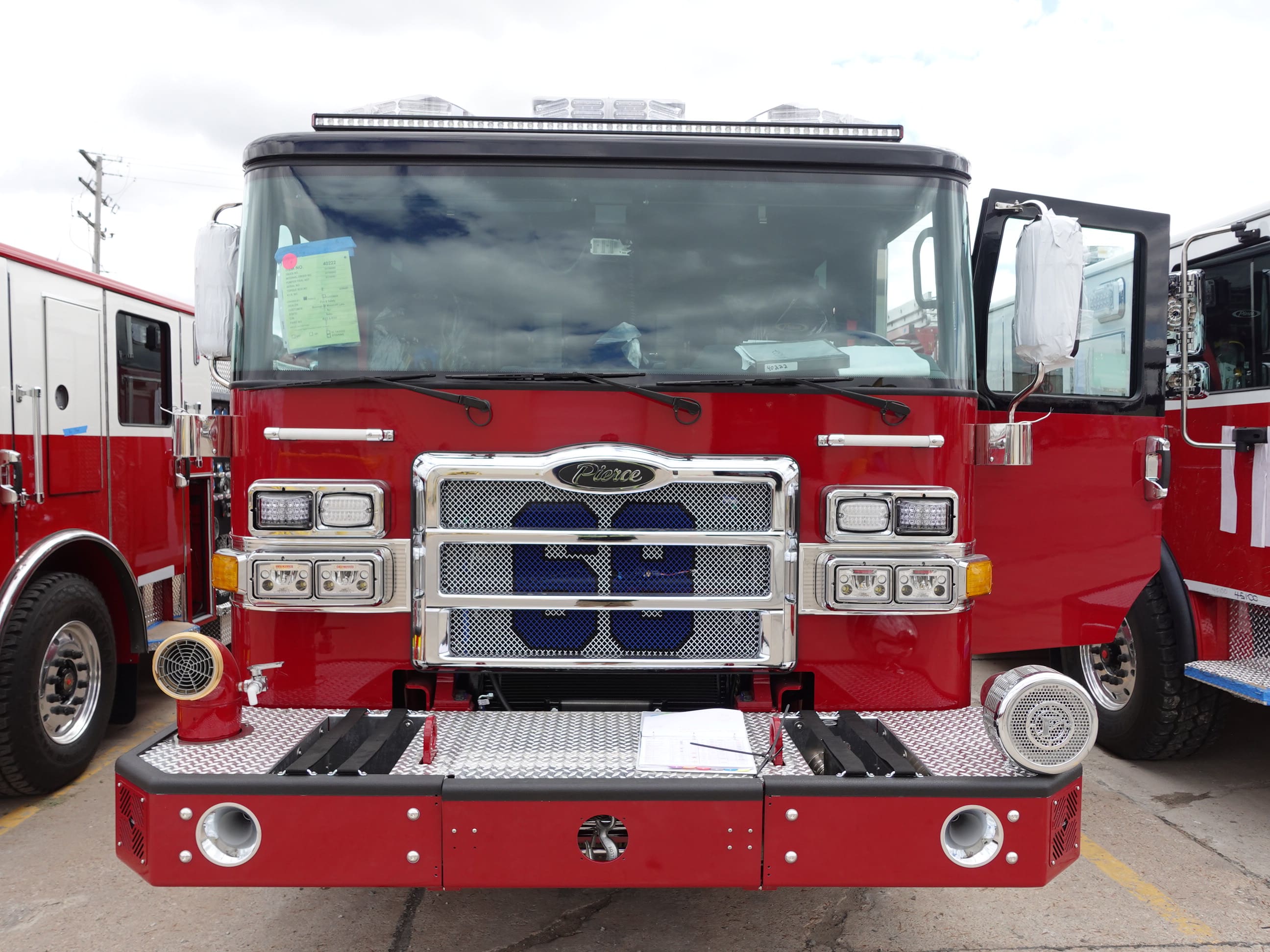

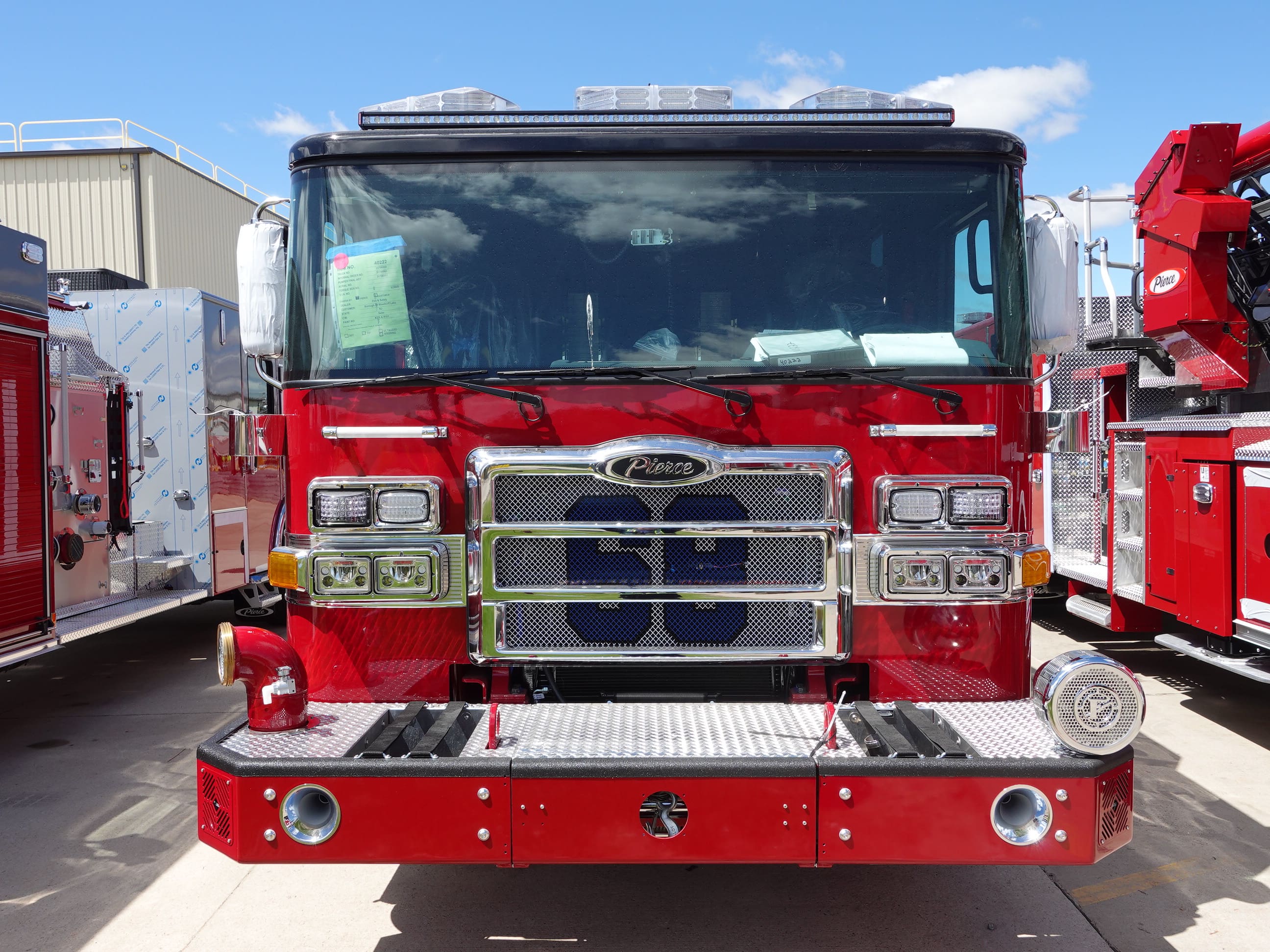

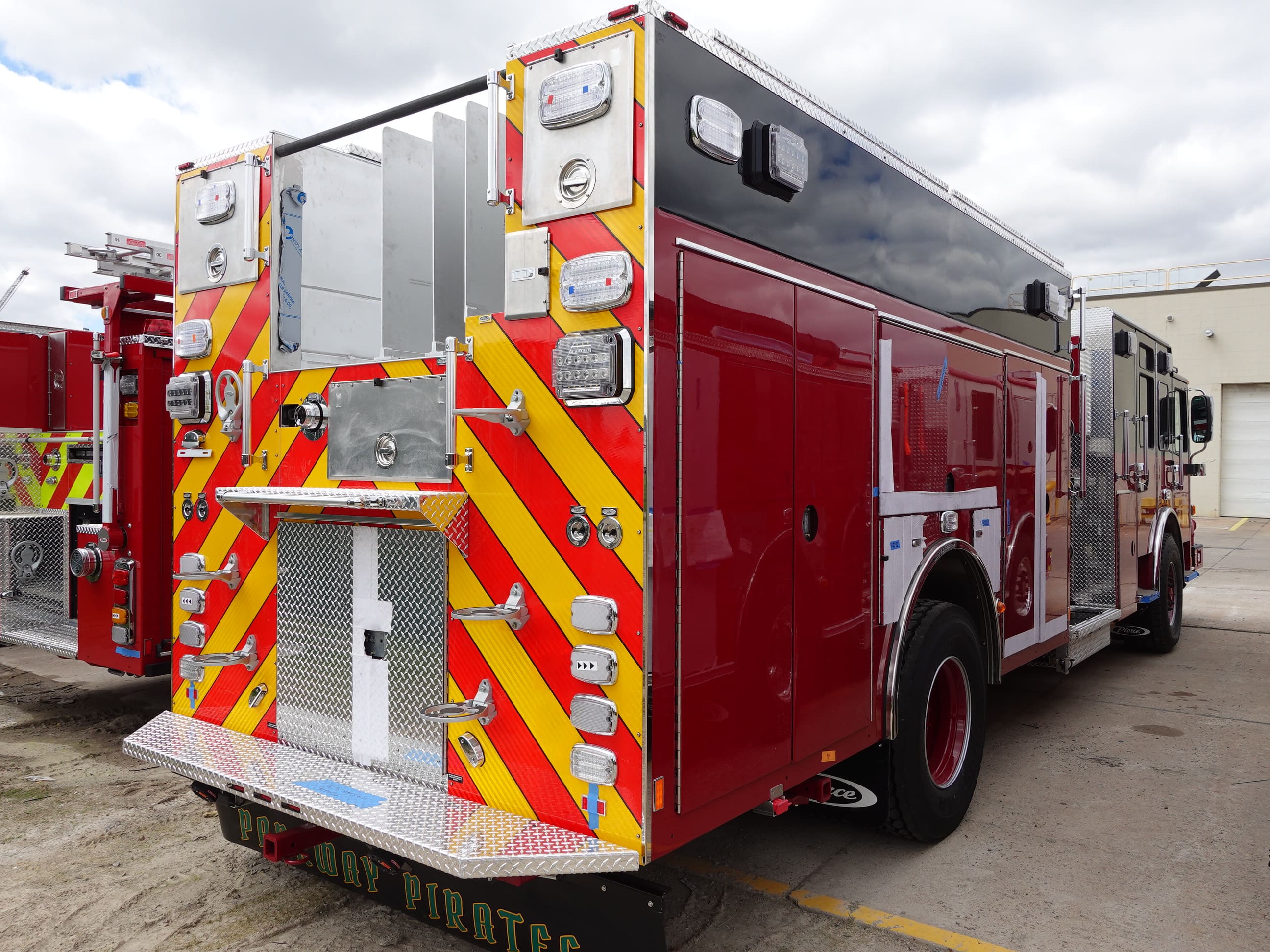

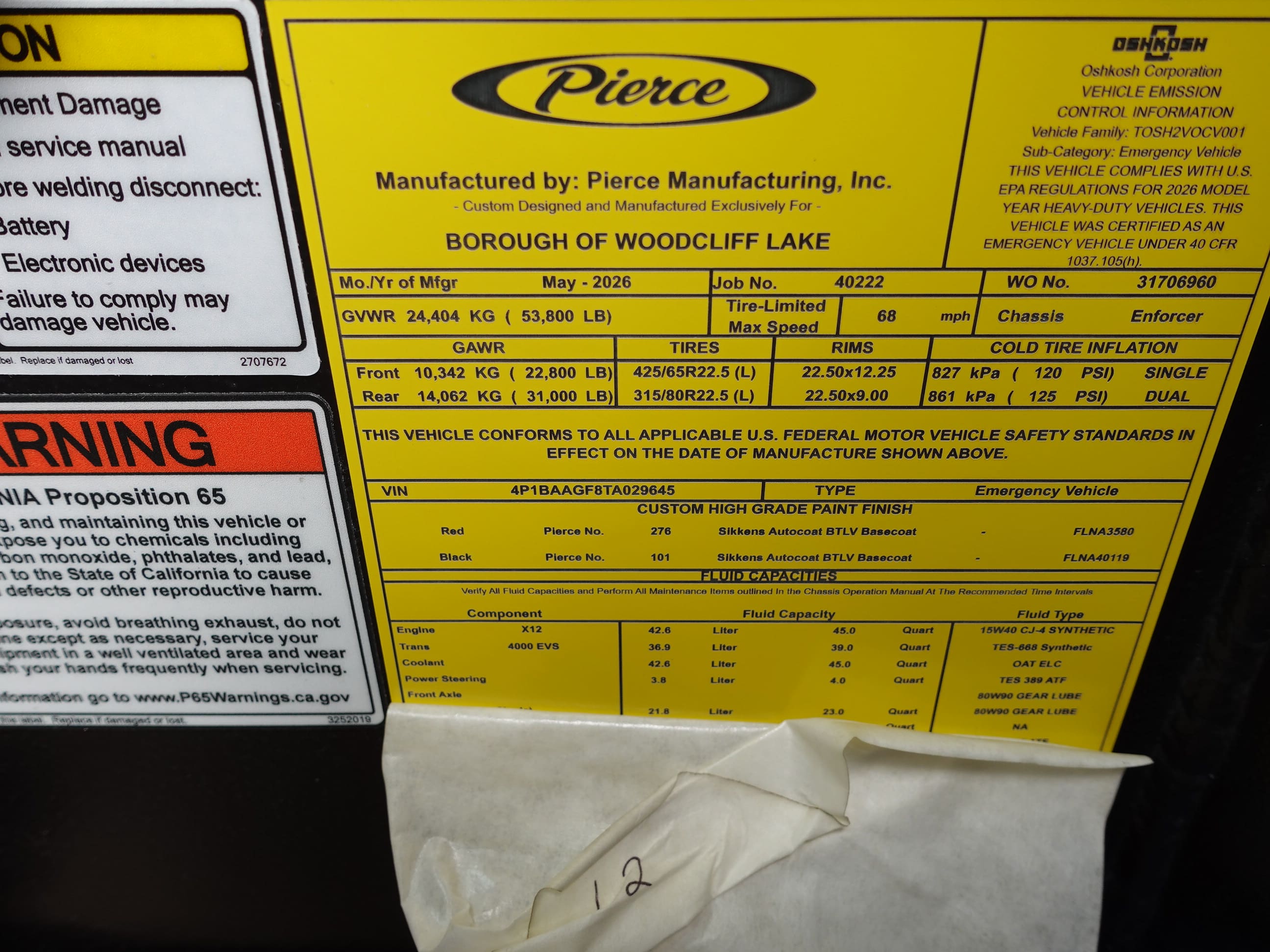

06-12-26

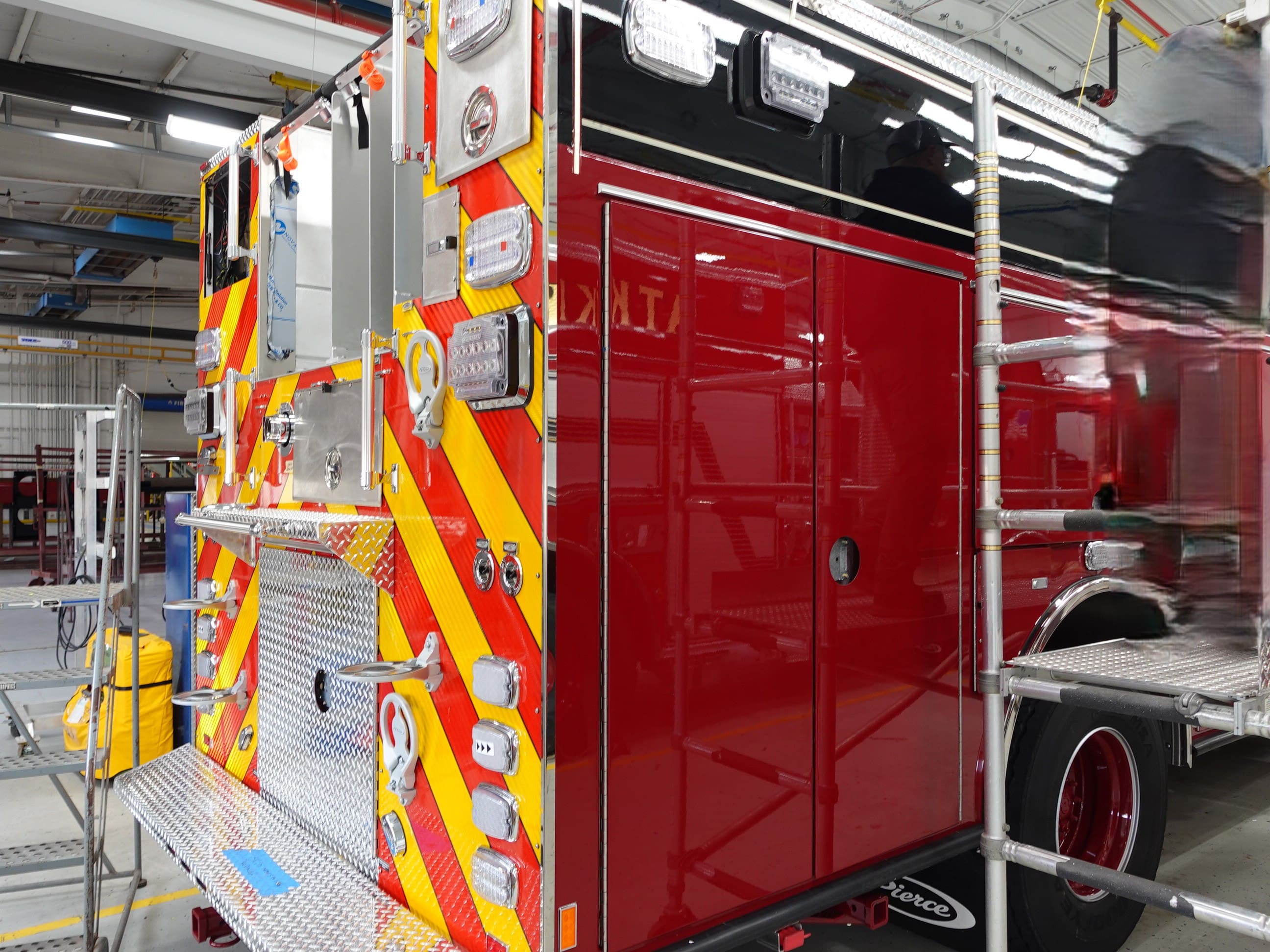

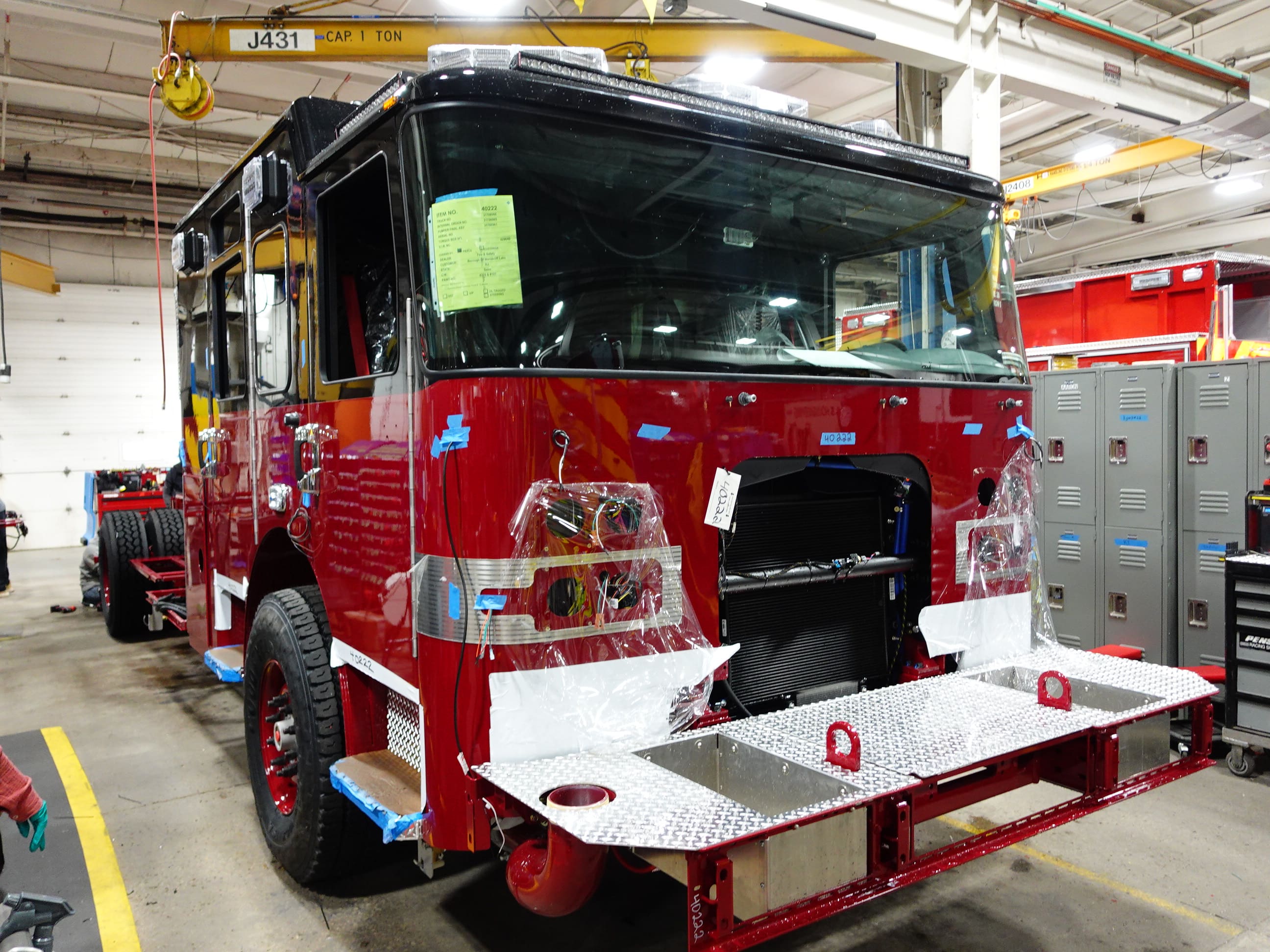

In this report, the apparatus continued the quality
process where any remaining content is applied. Once
complete it will be made ready for the customer

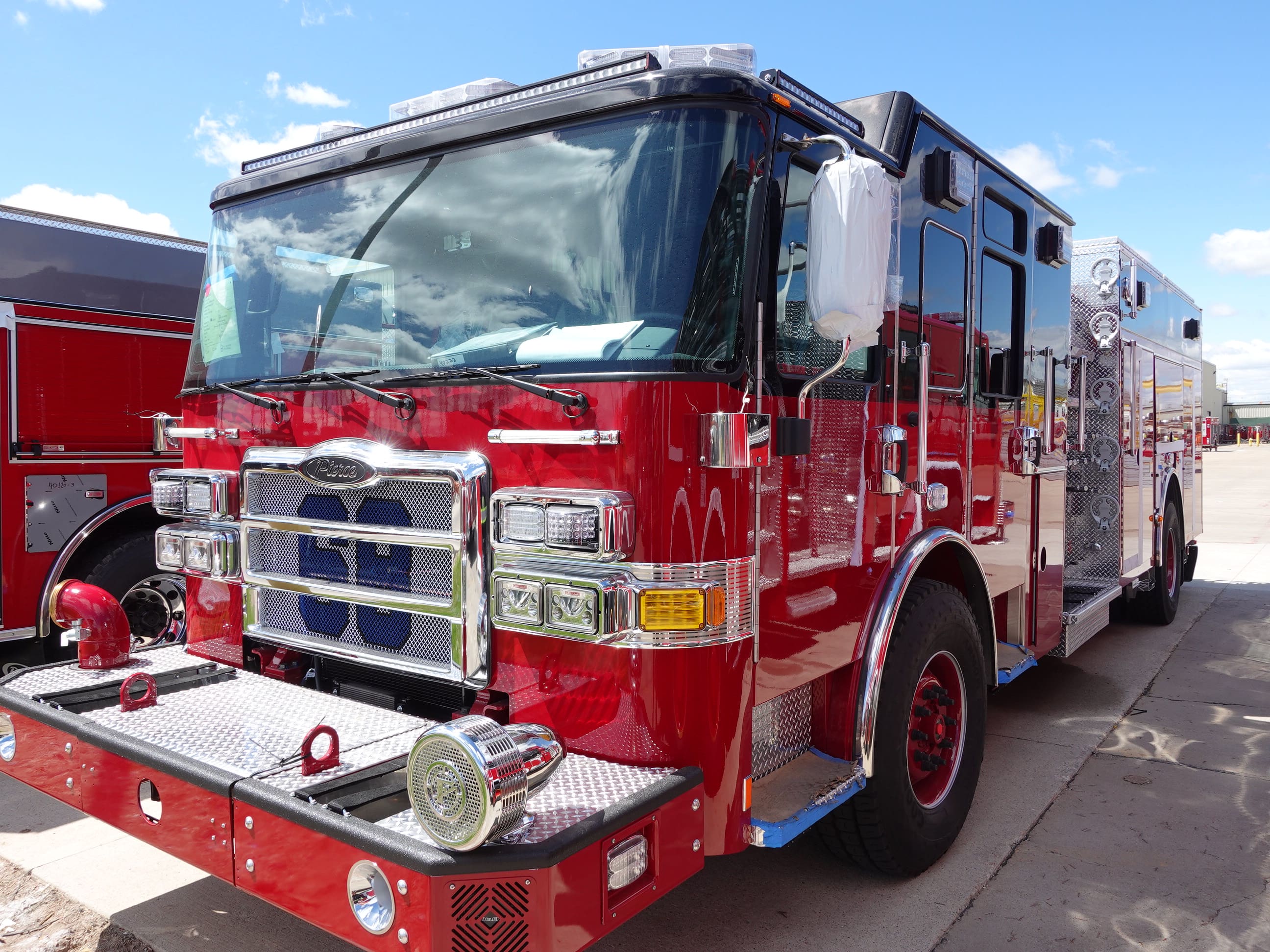

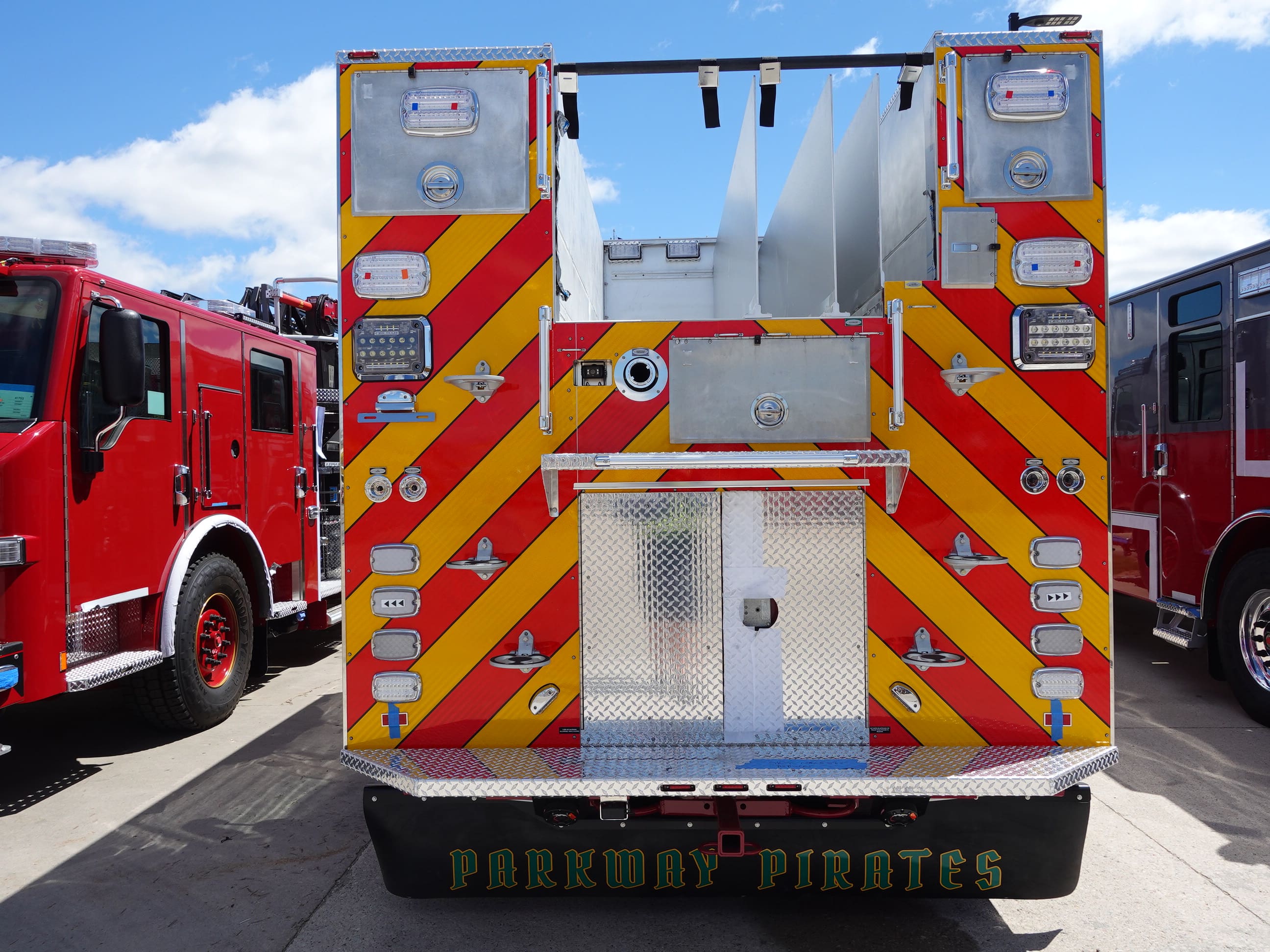

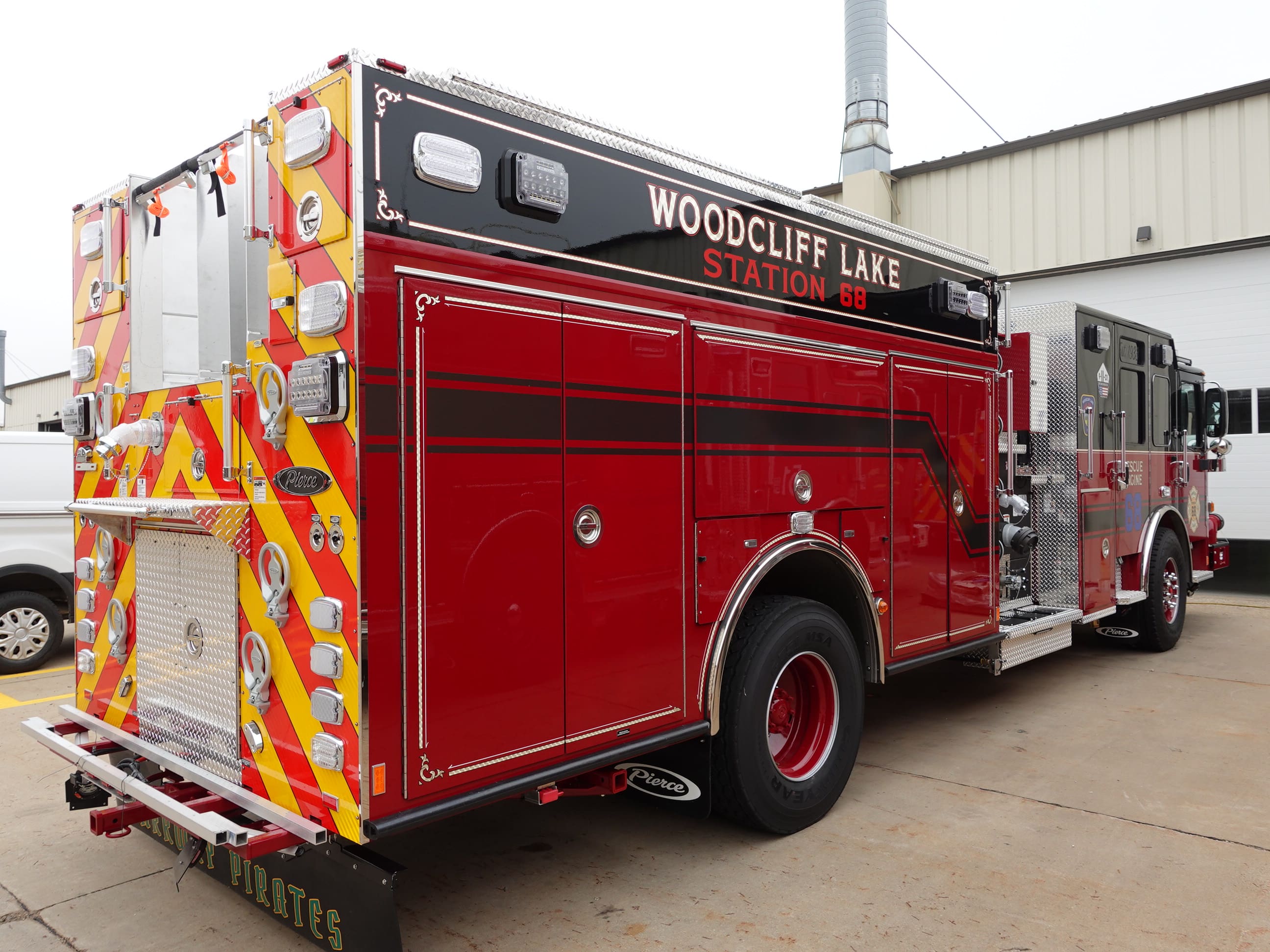

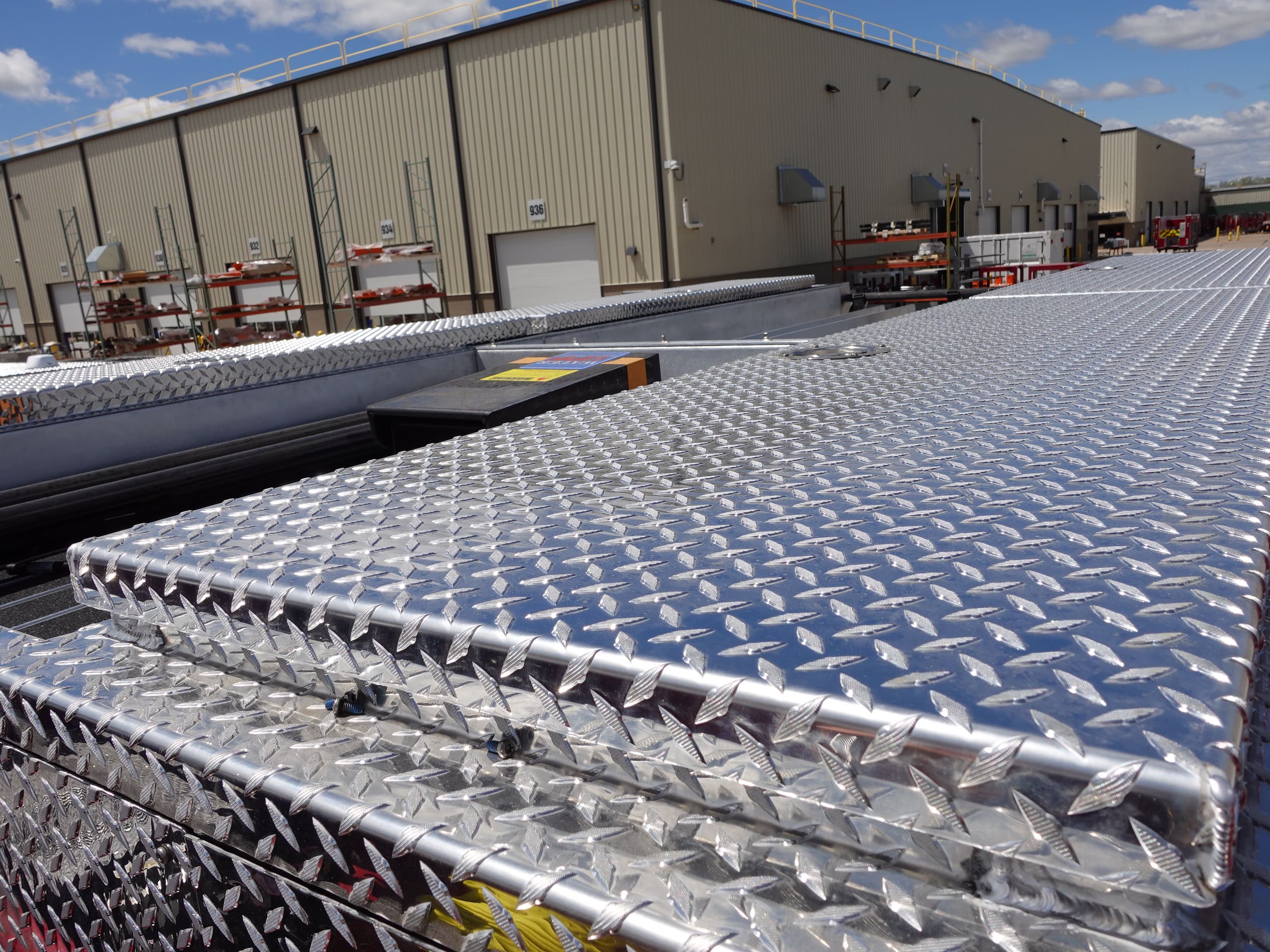

acceptance inspection. This is the last scheduled report.
06-05-26
In this report, the apparatus continued through quality
and graphics where any remaining content is applied.
05-22-26
In this report, the apparatus completed testing then released to quality and graphics where
any remaining content will be applied.

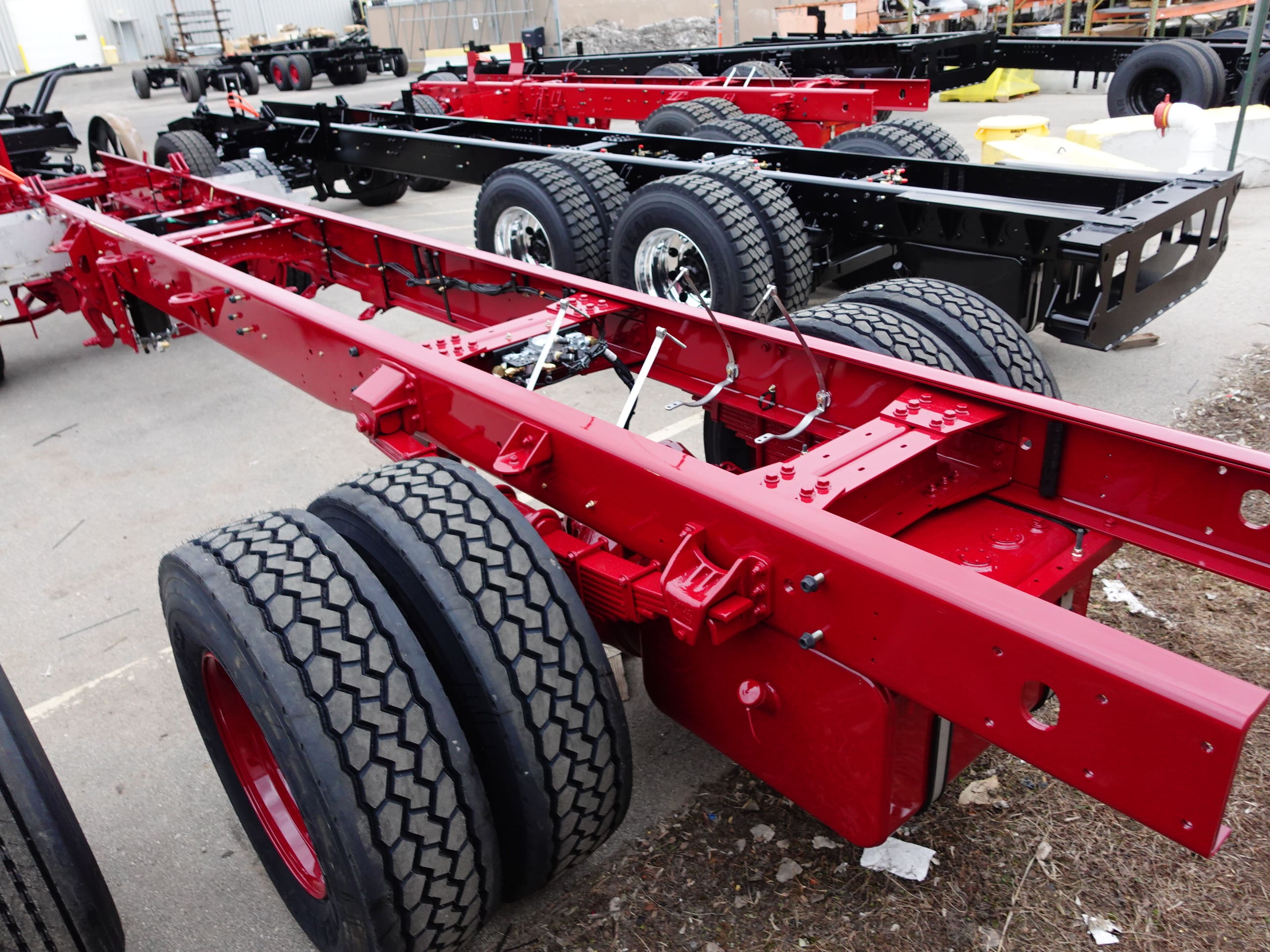

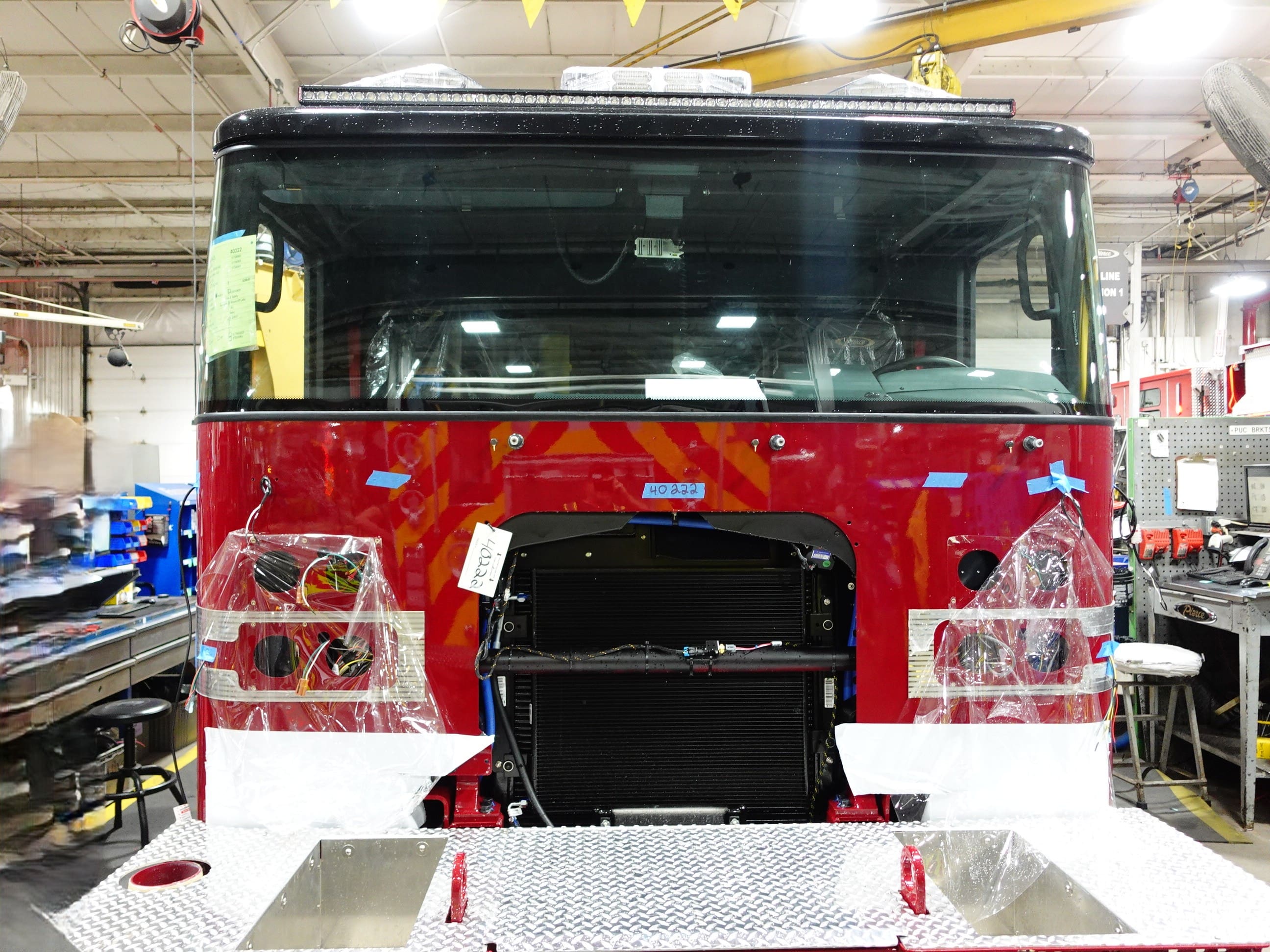

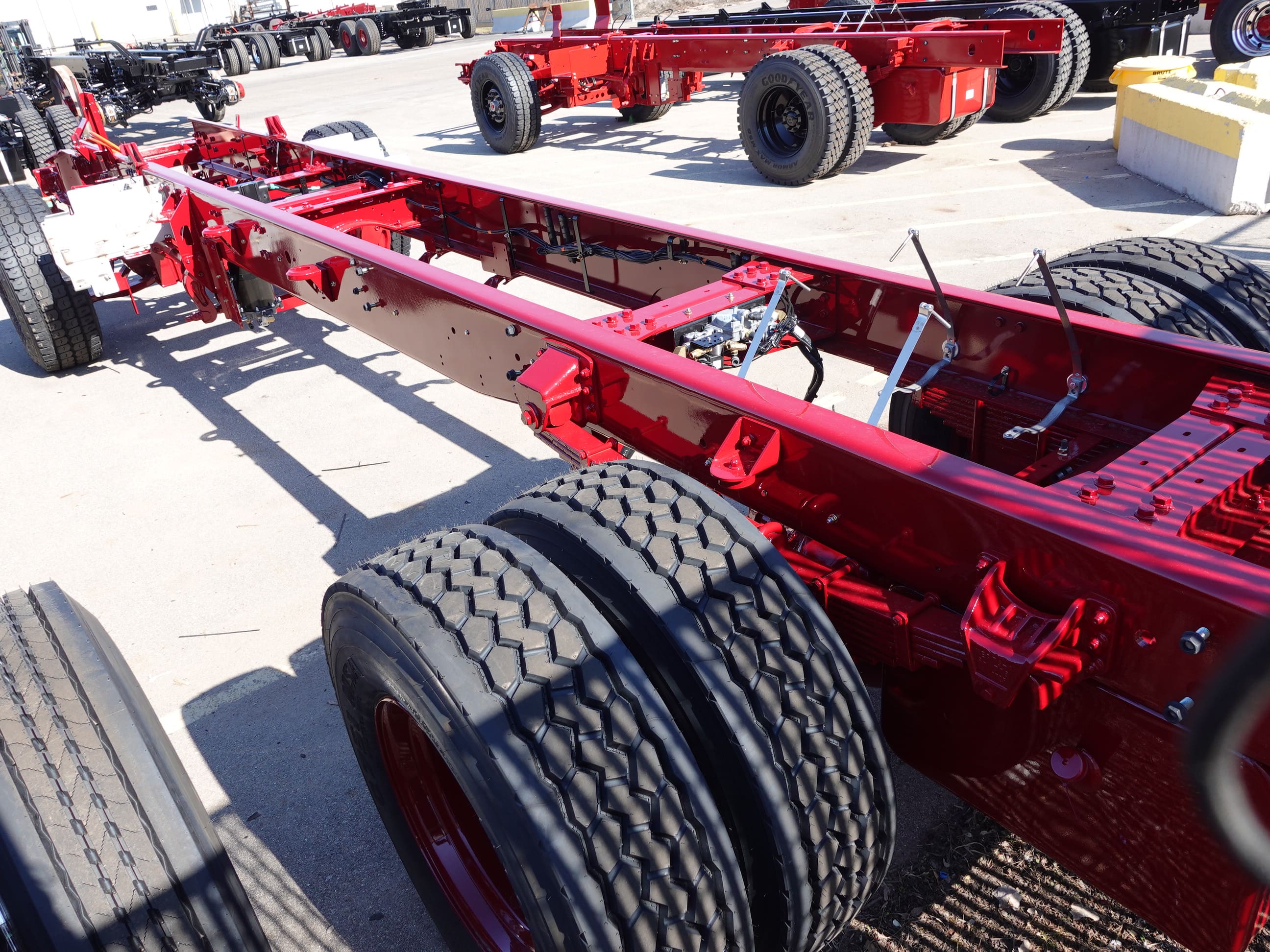

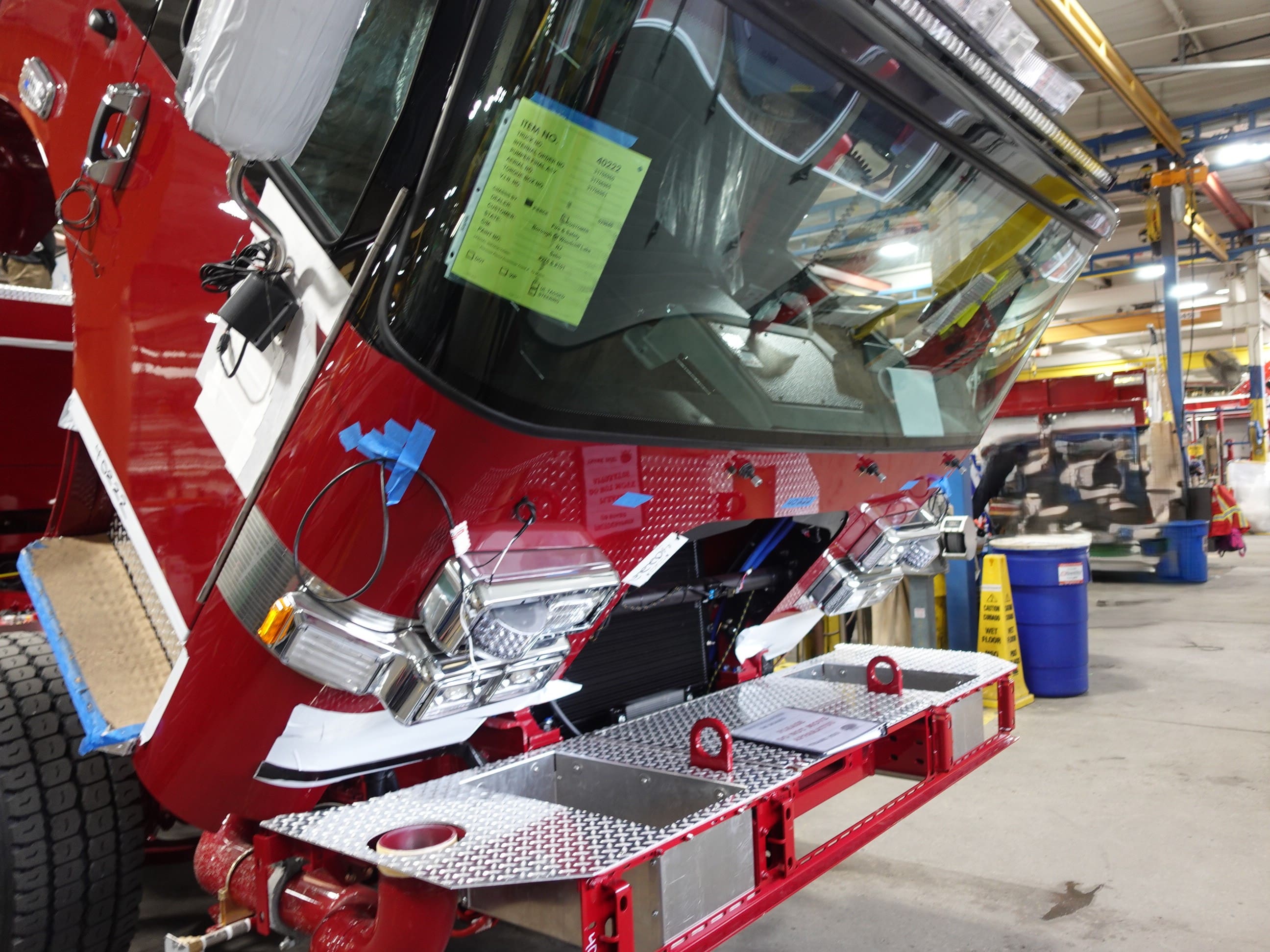

04-17-26

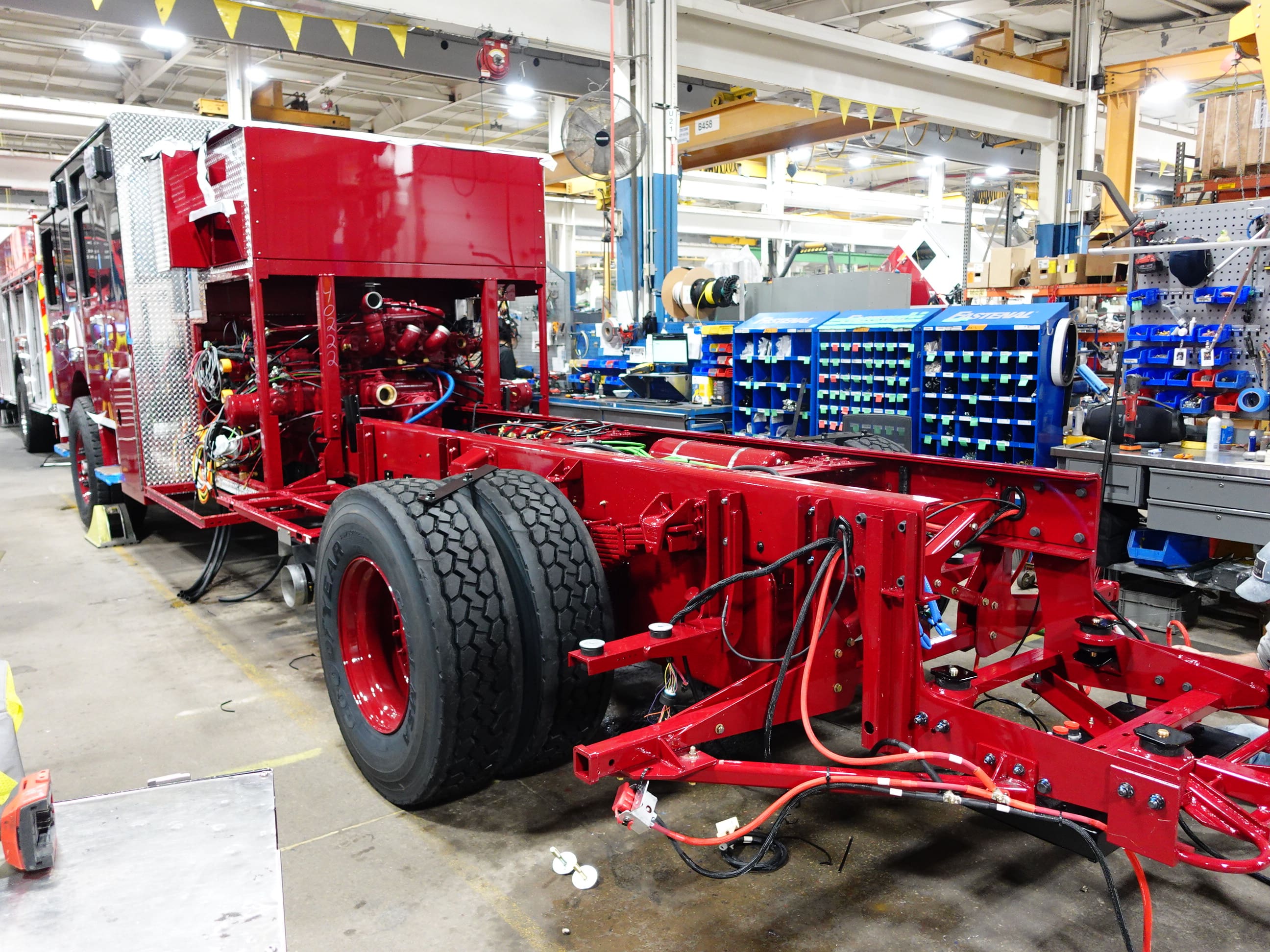

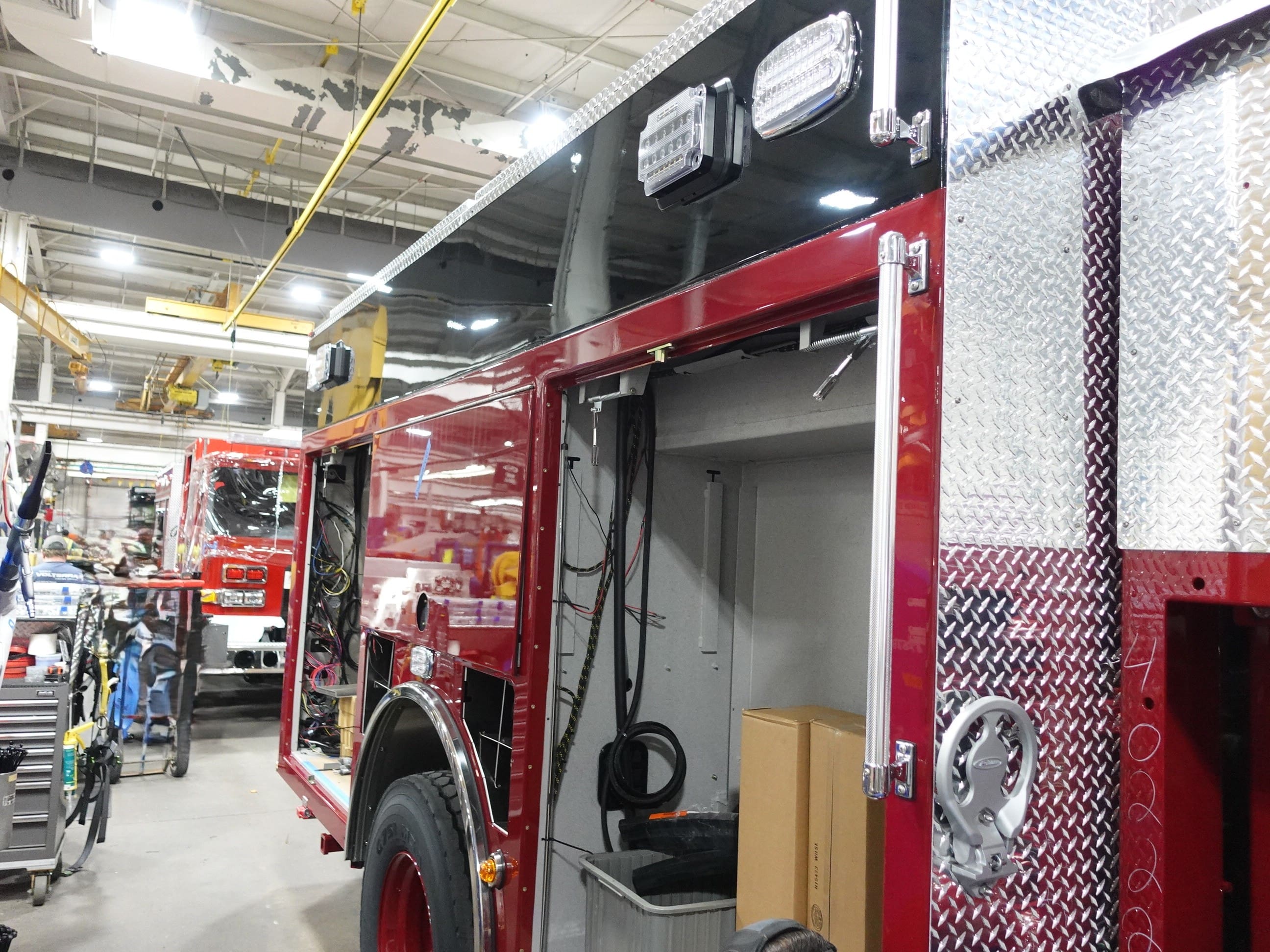

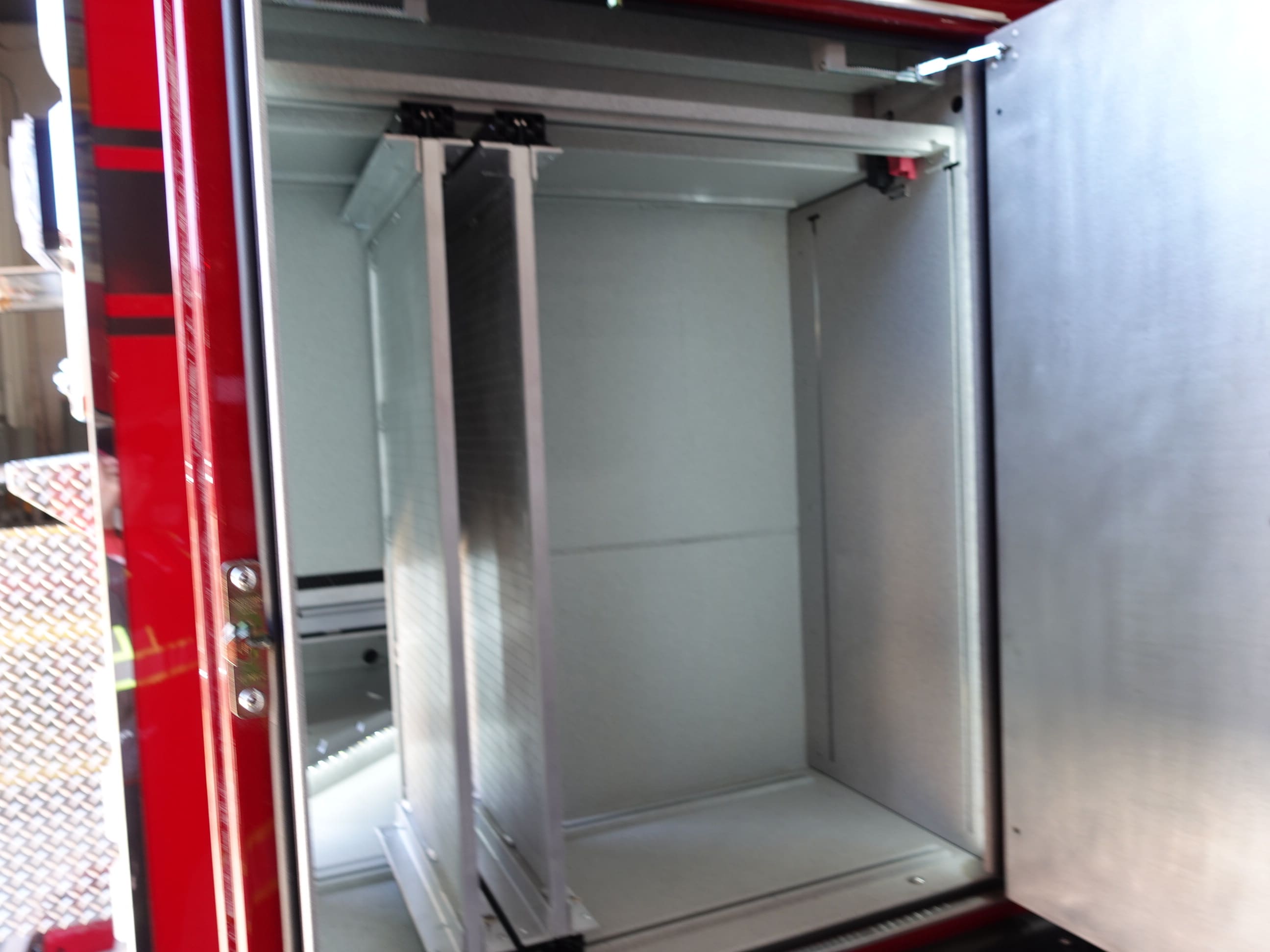

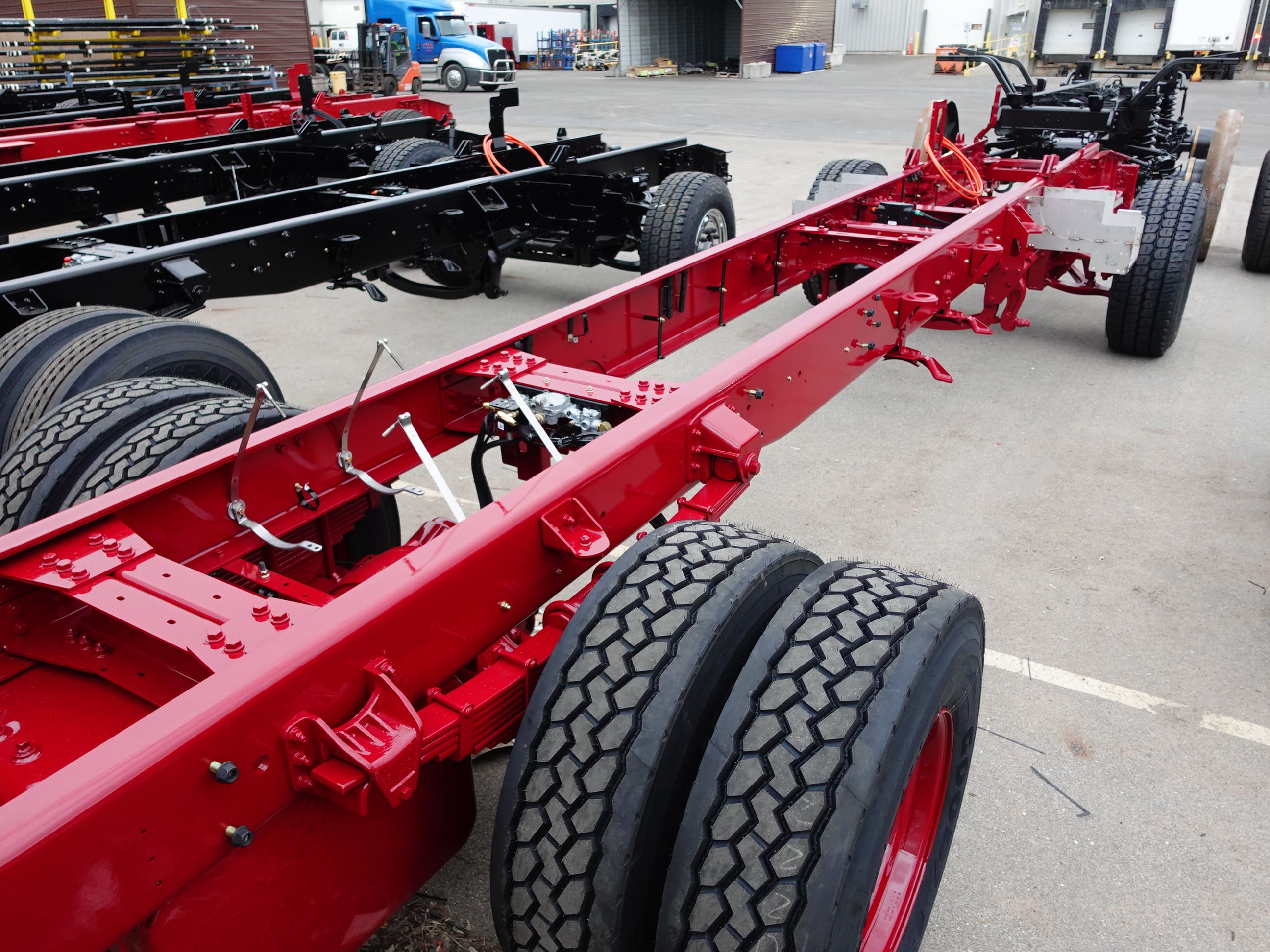

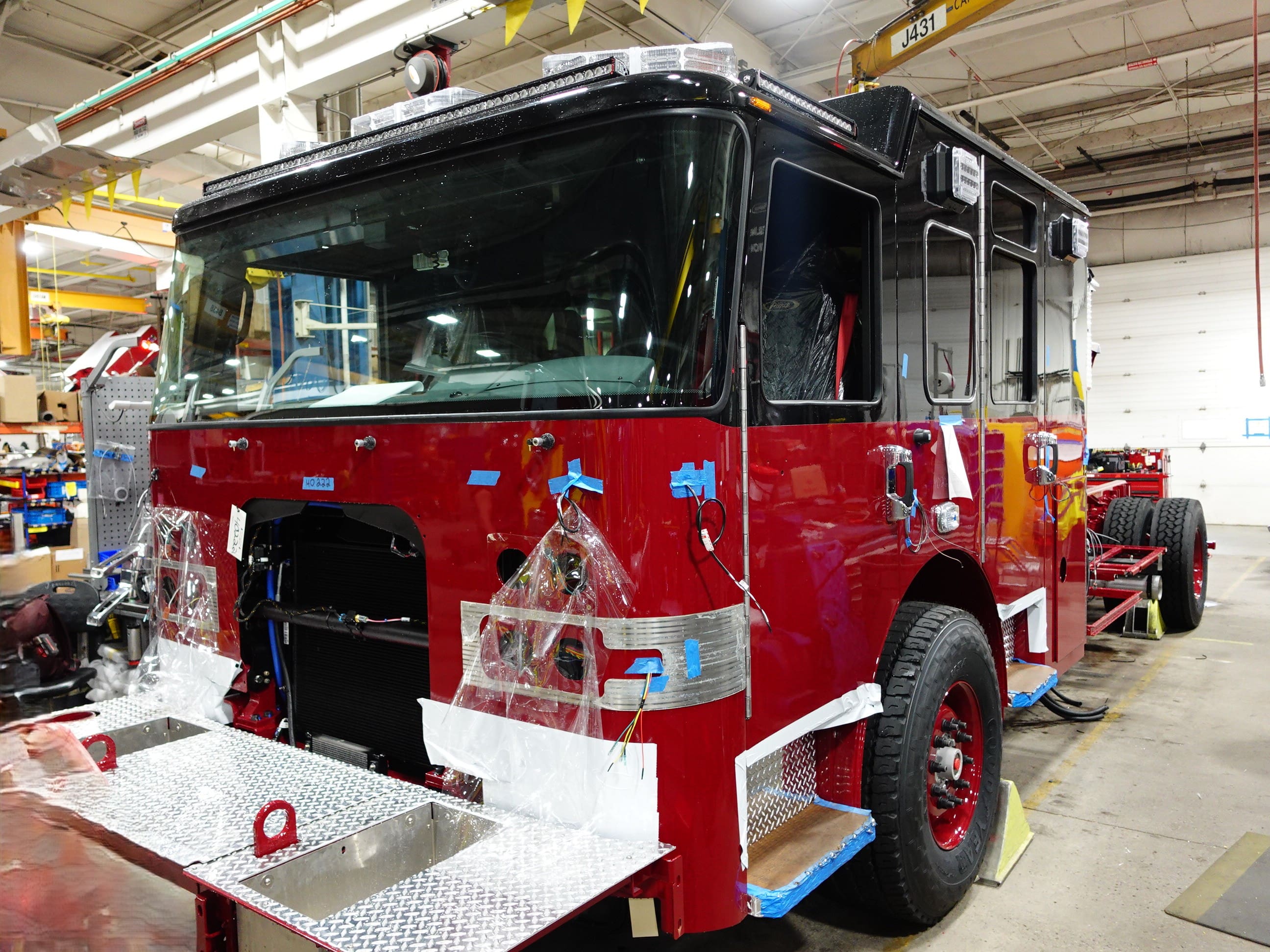

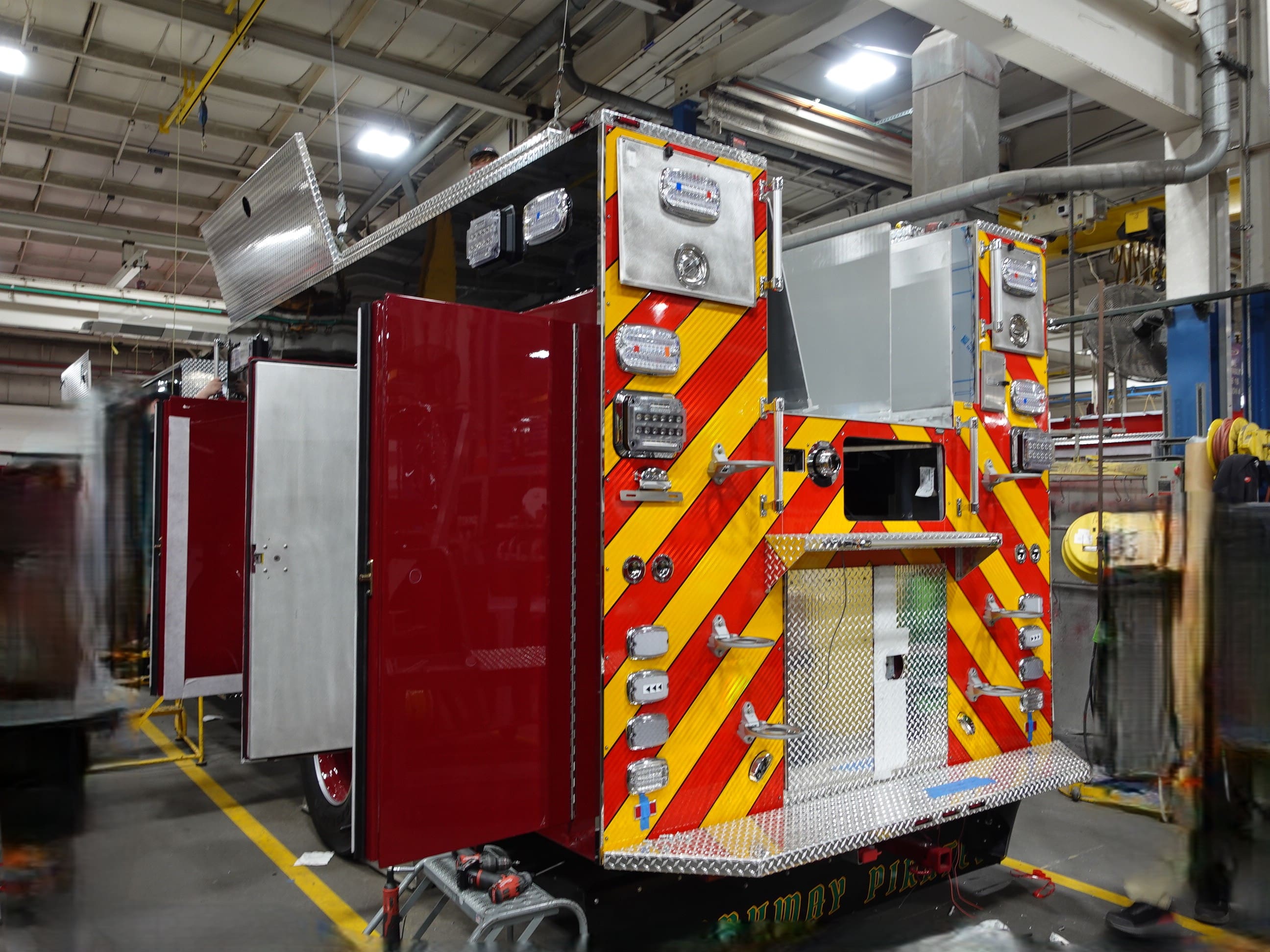

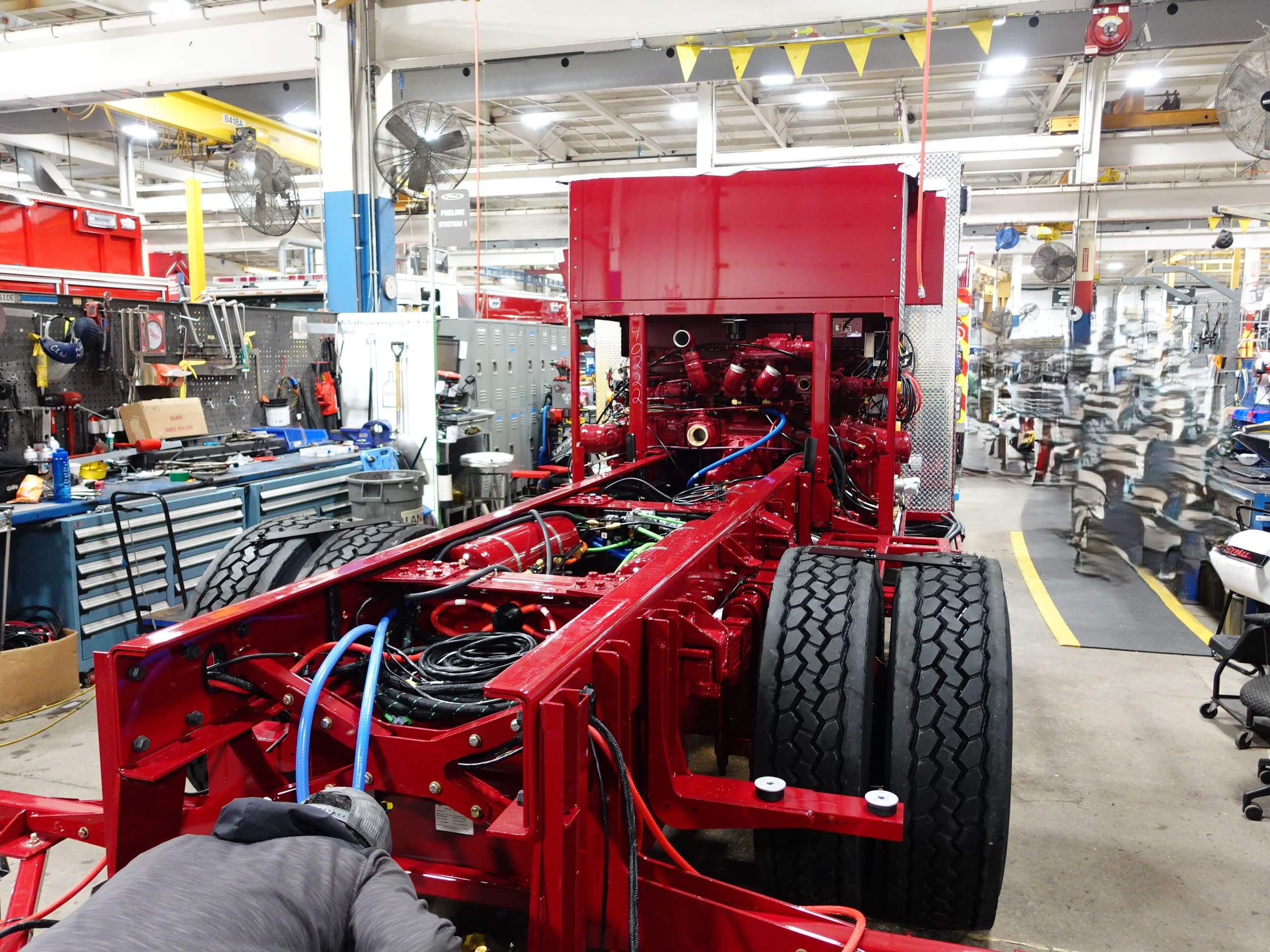

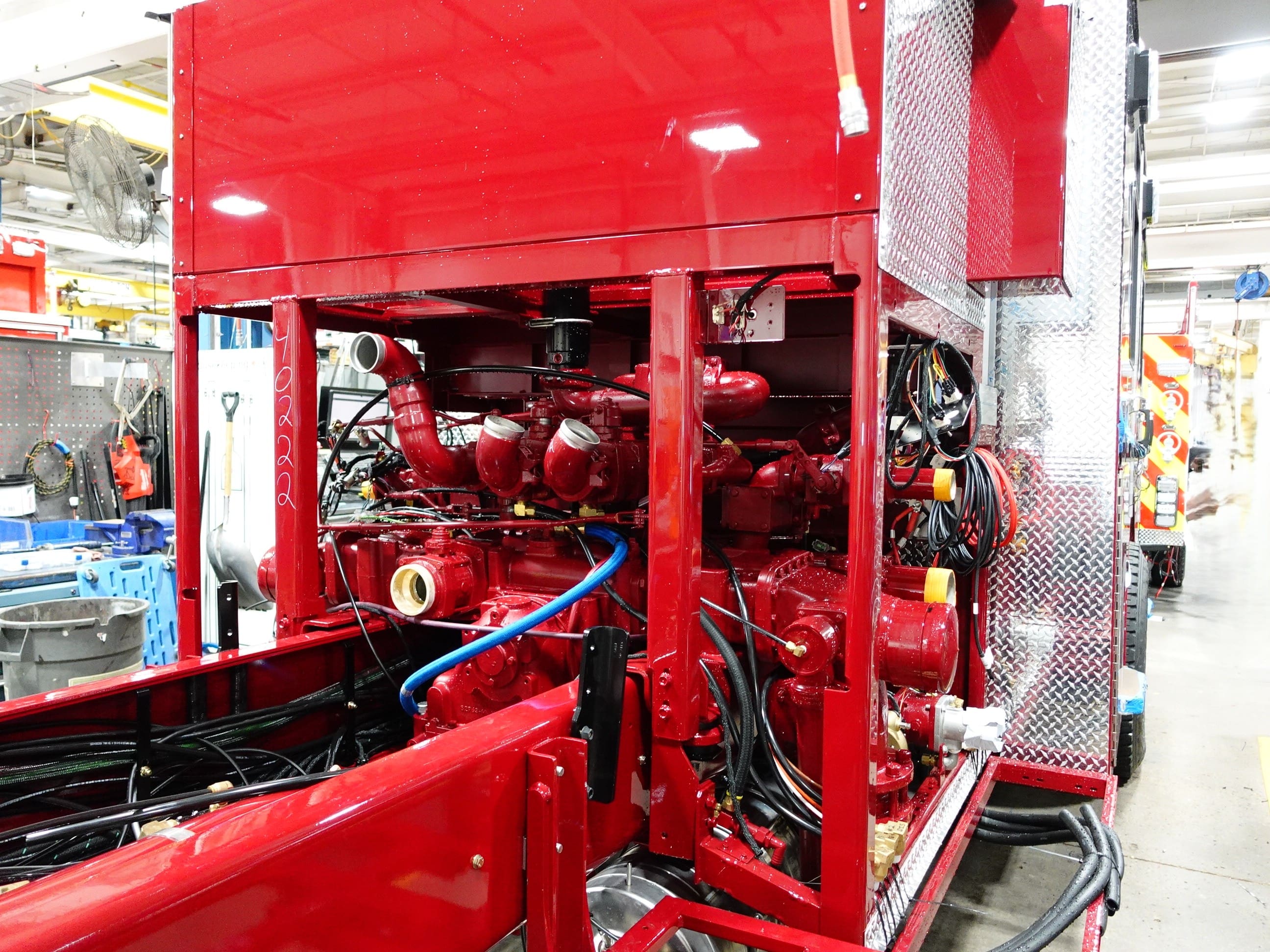

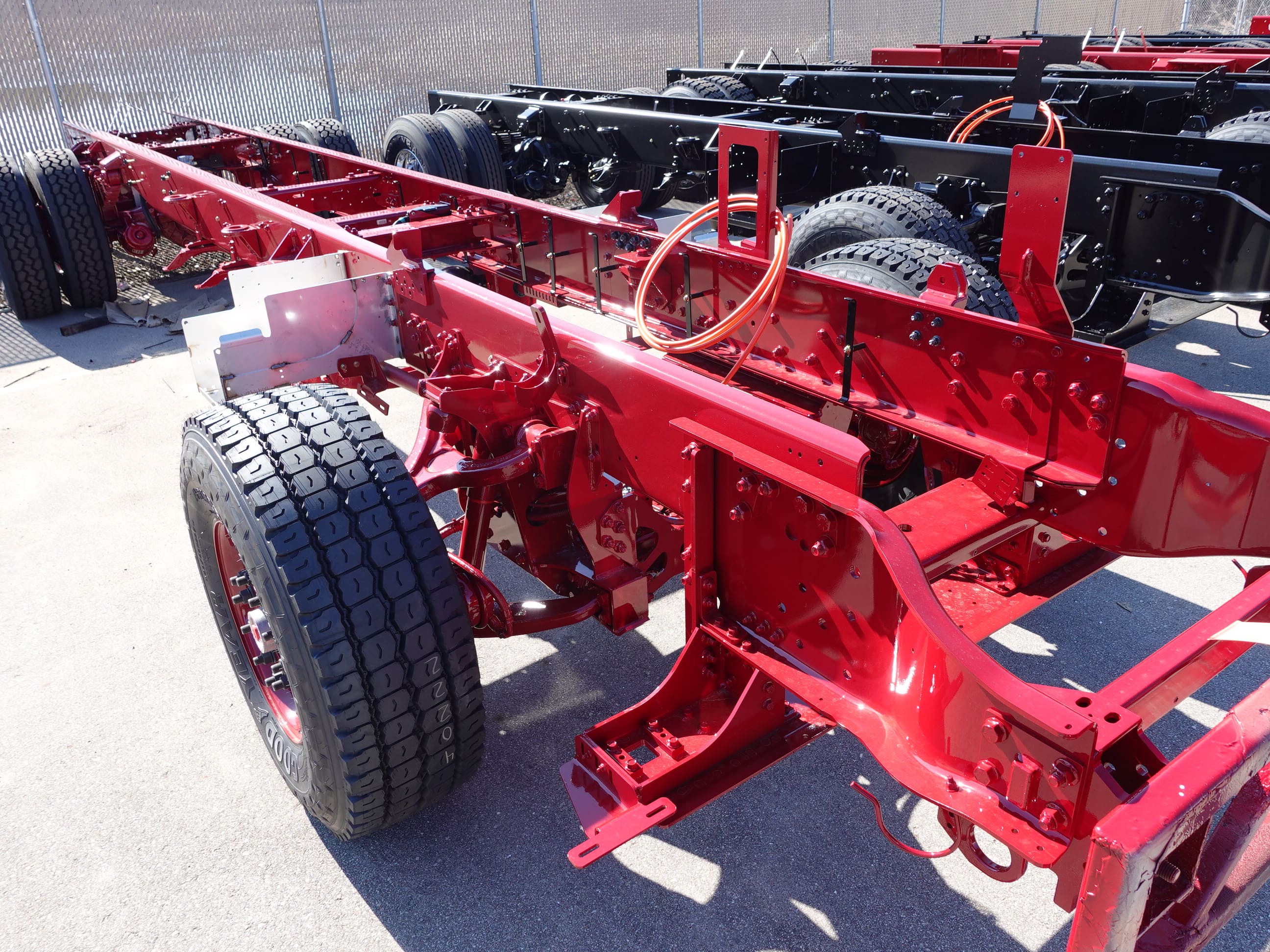

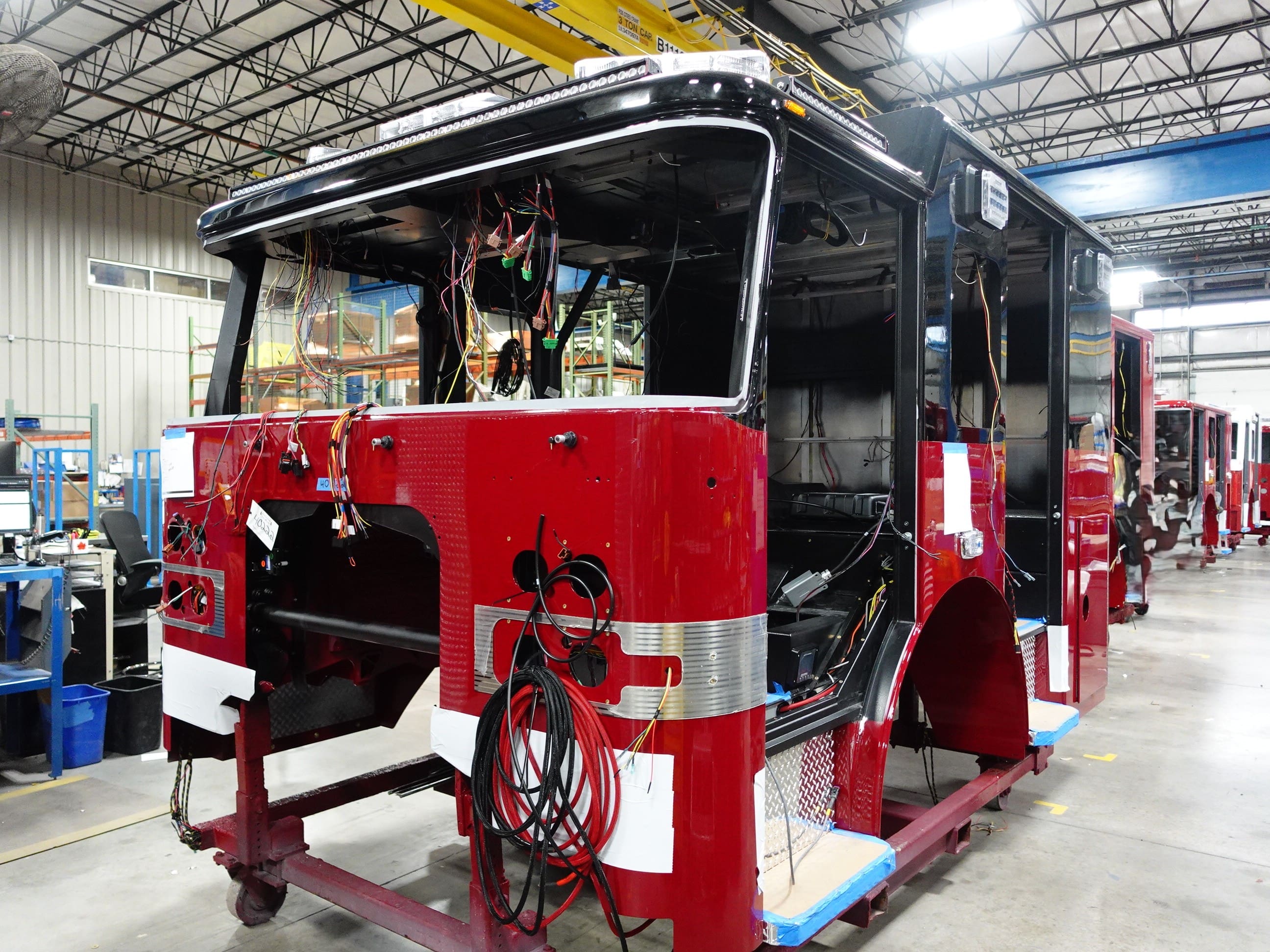

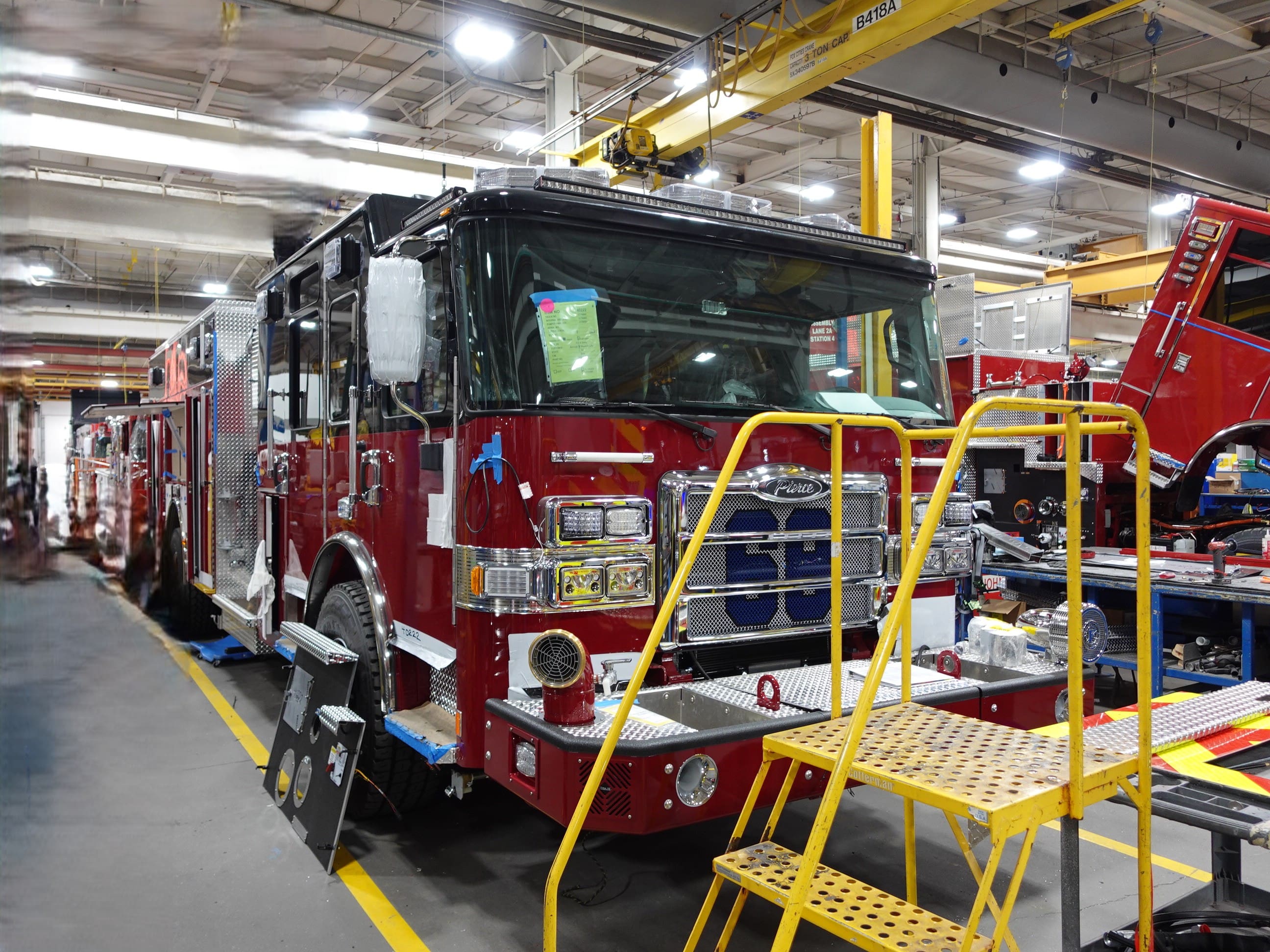

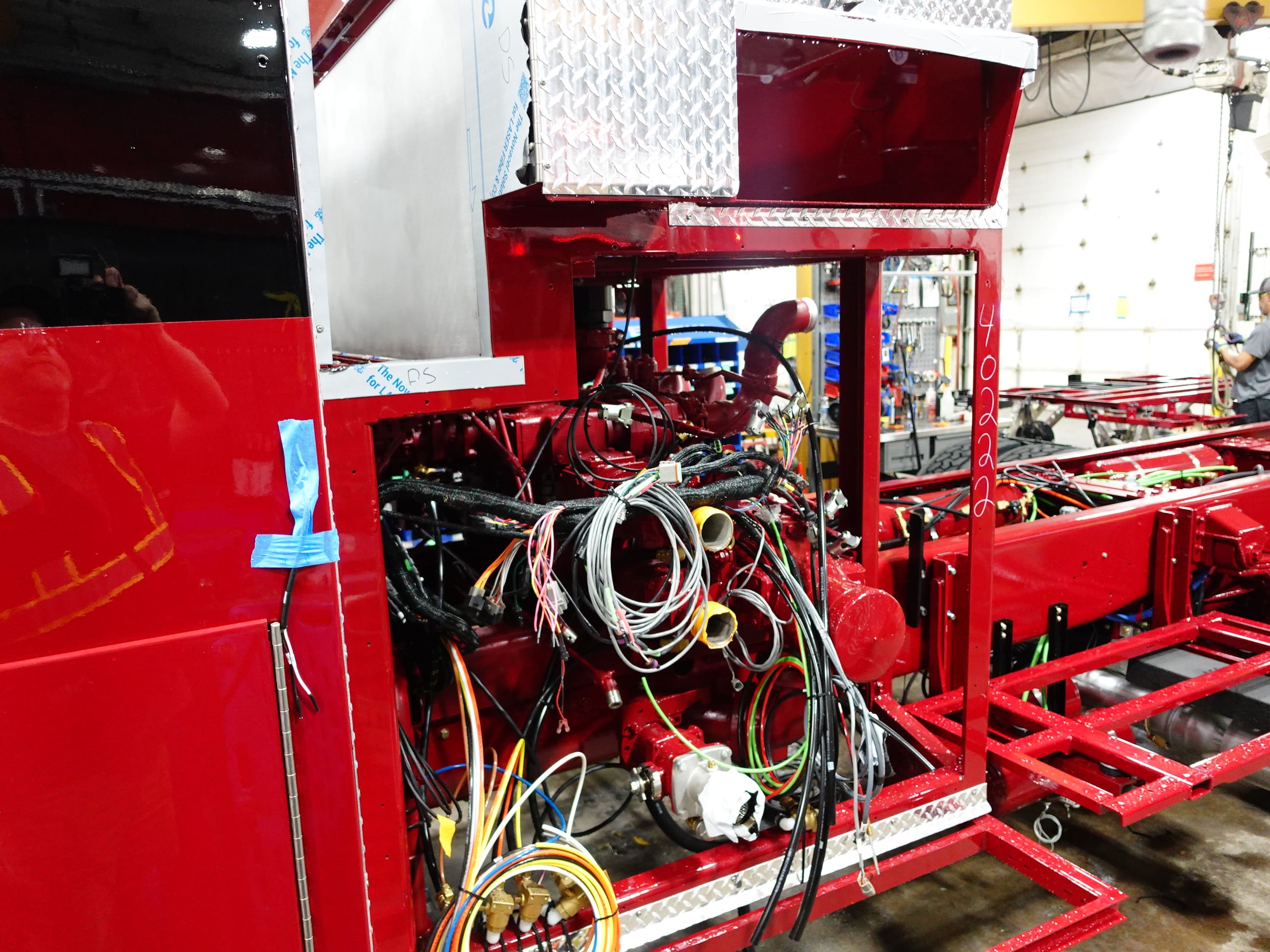

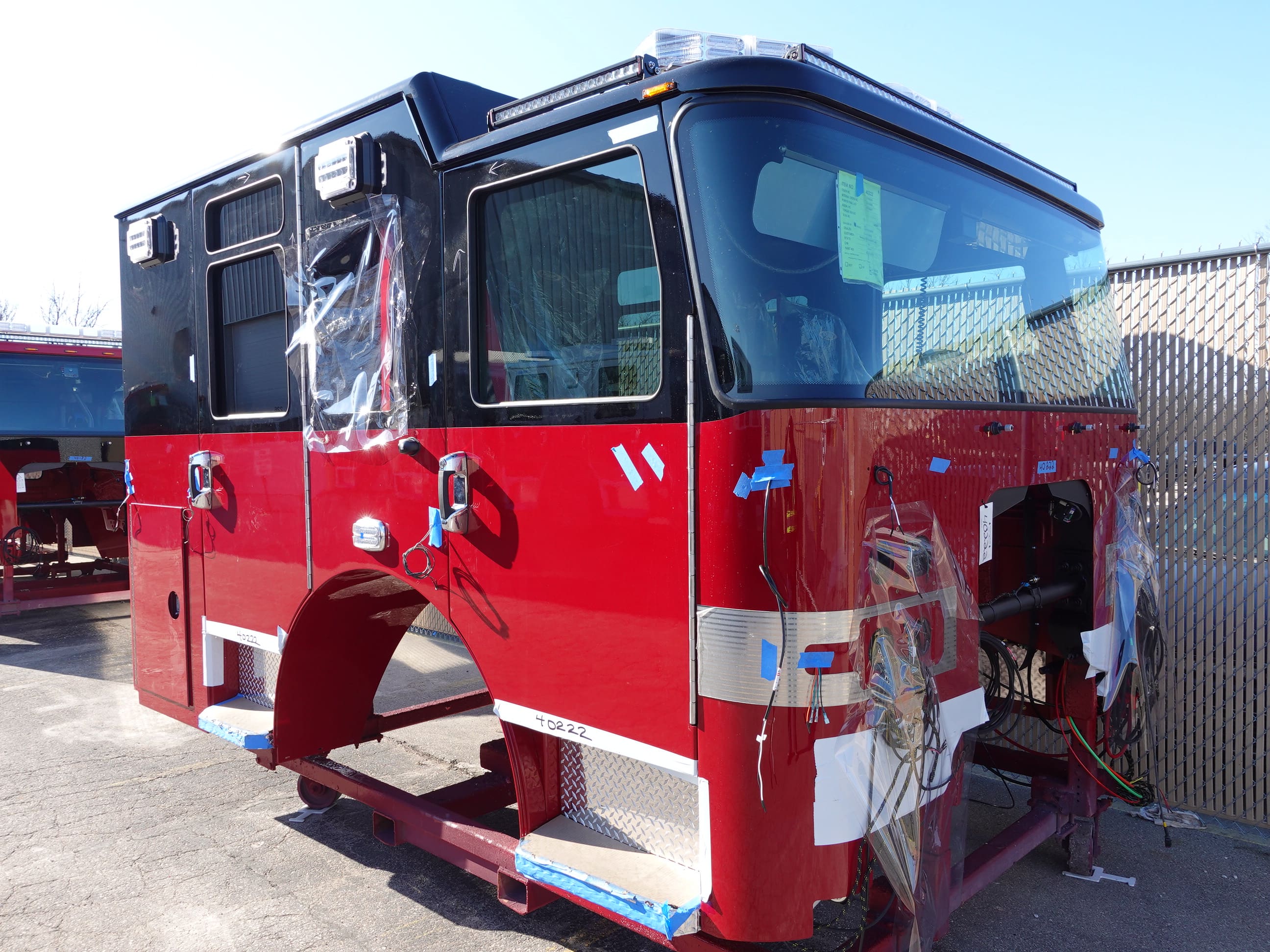

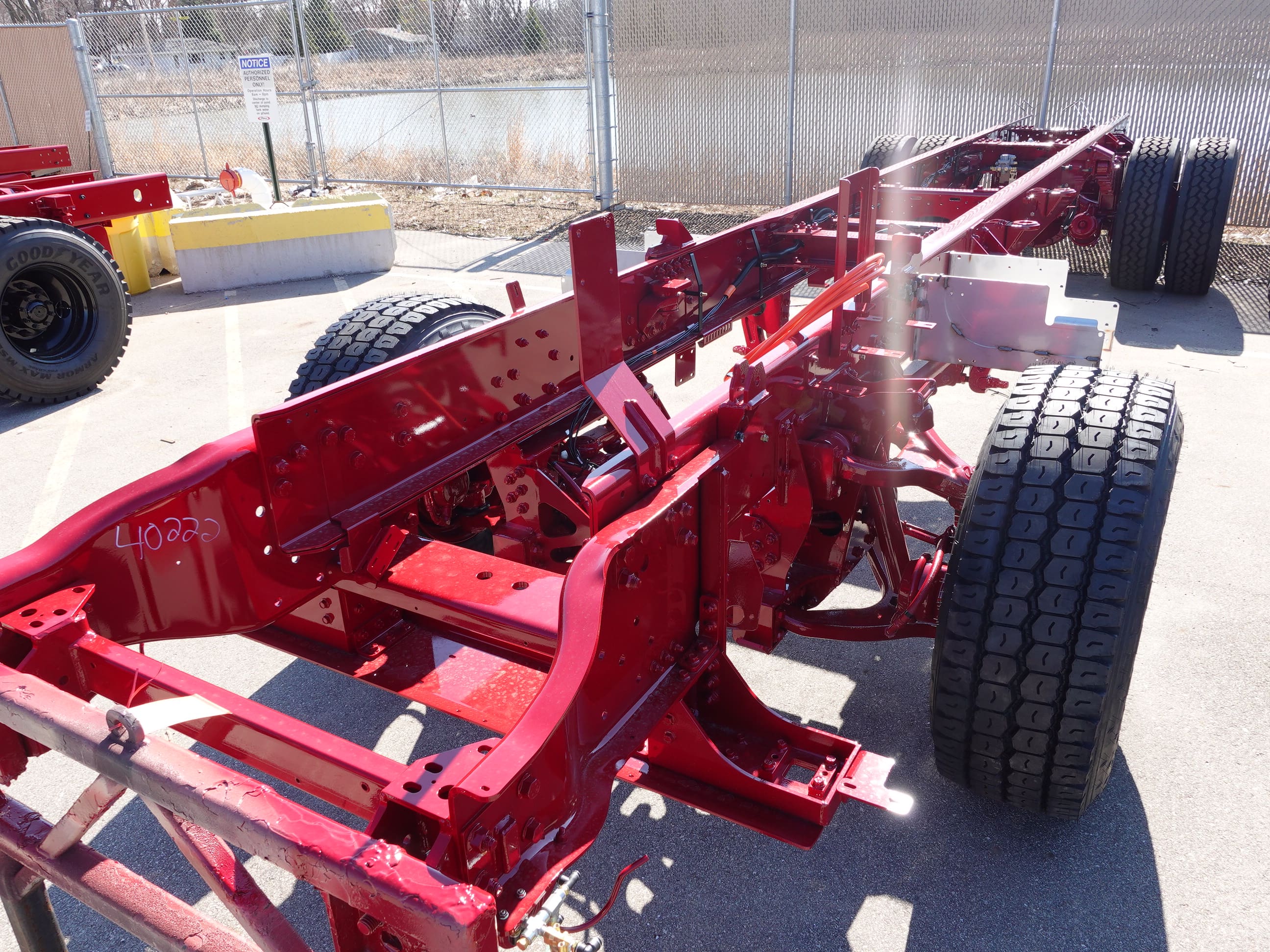

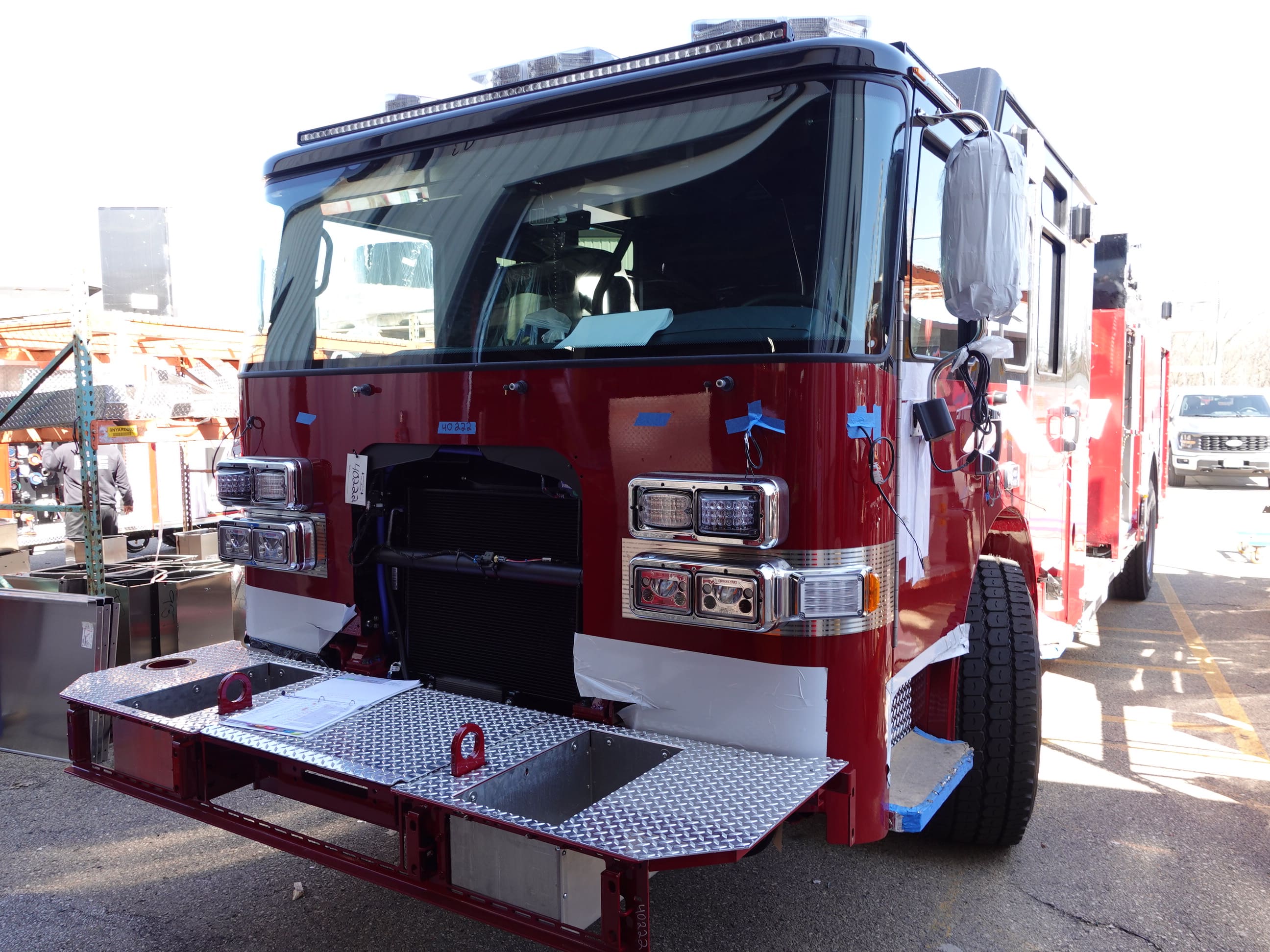

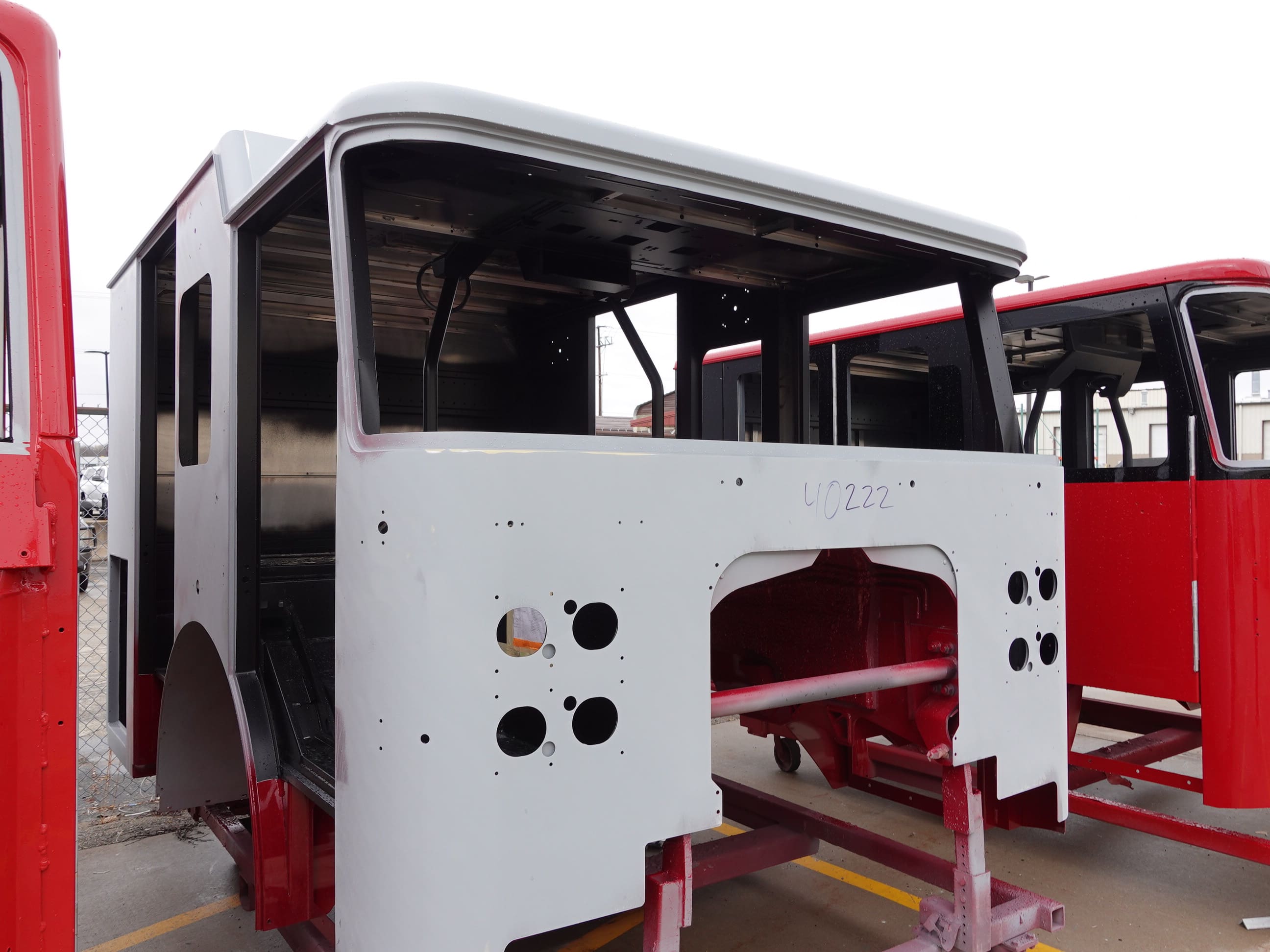

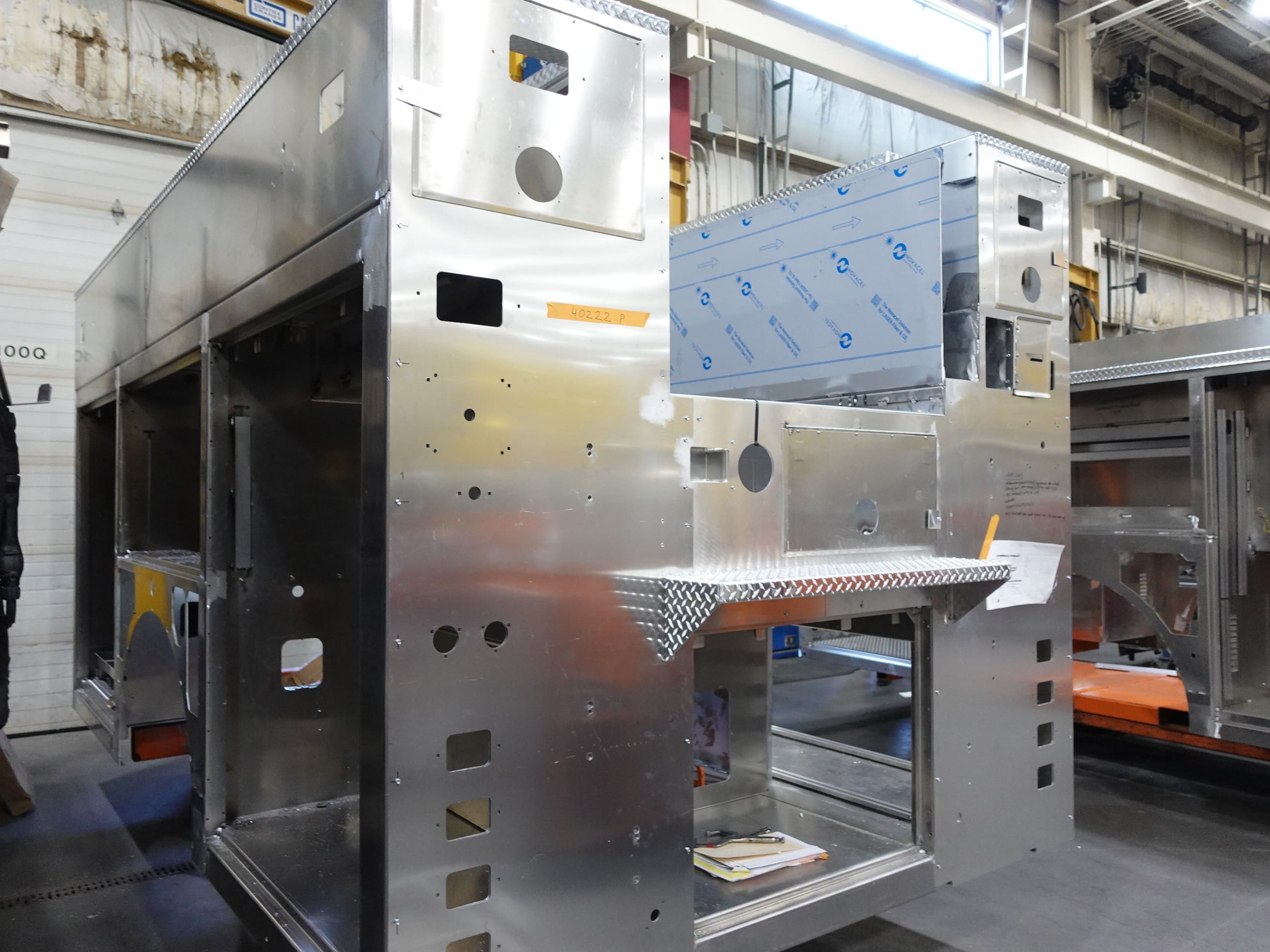

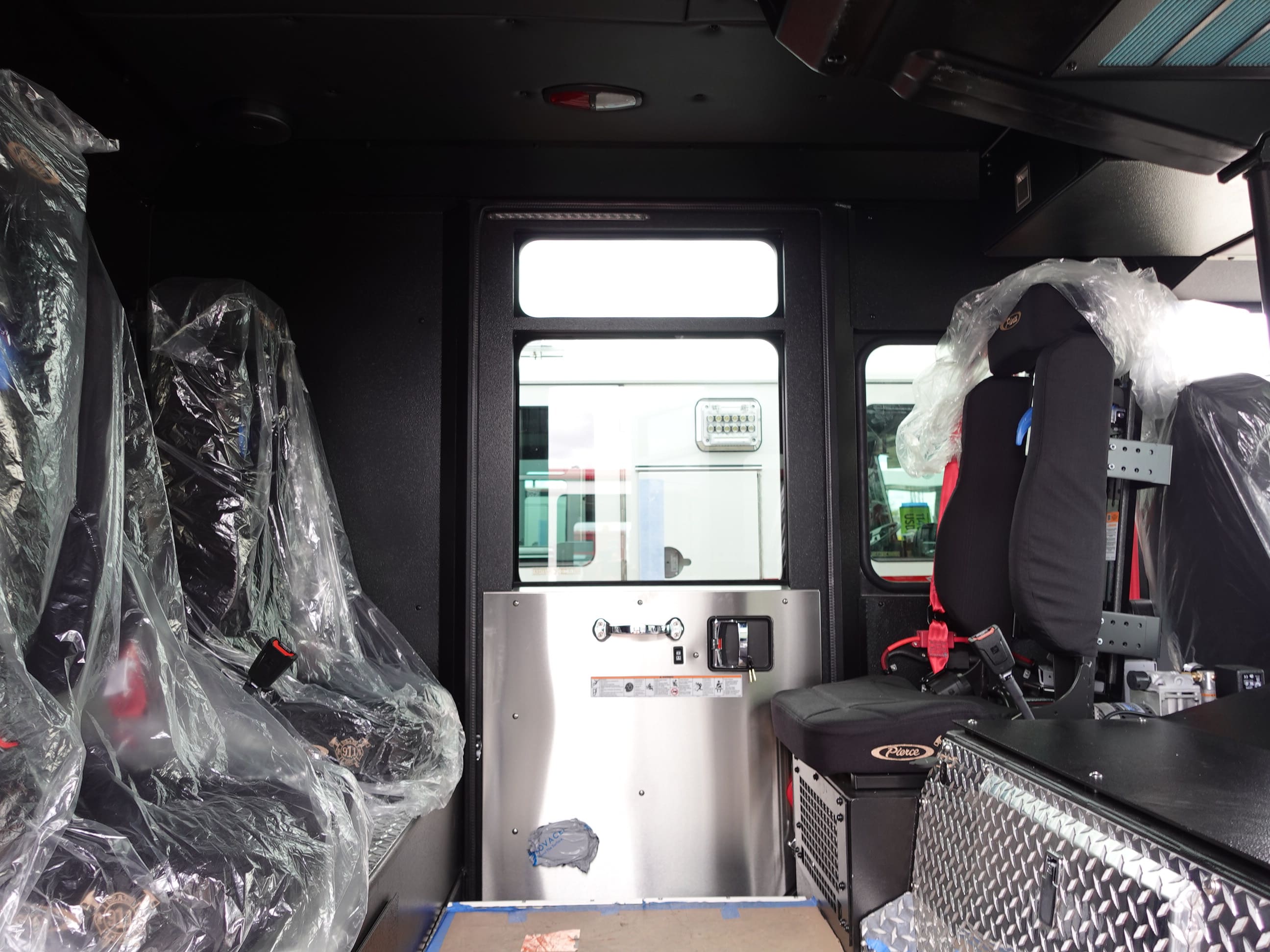

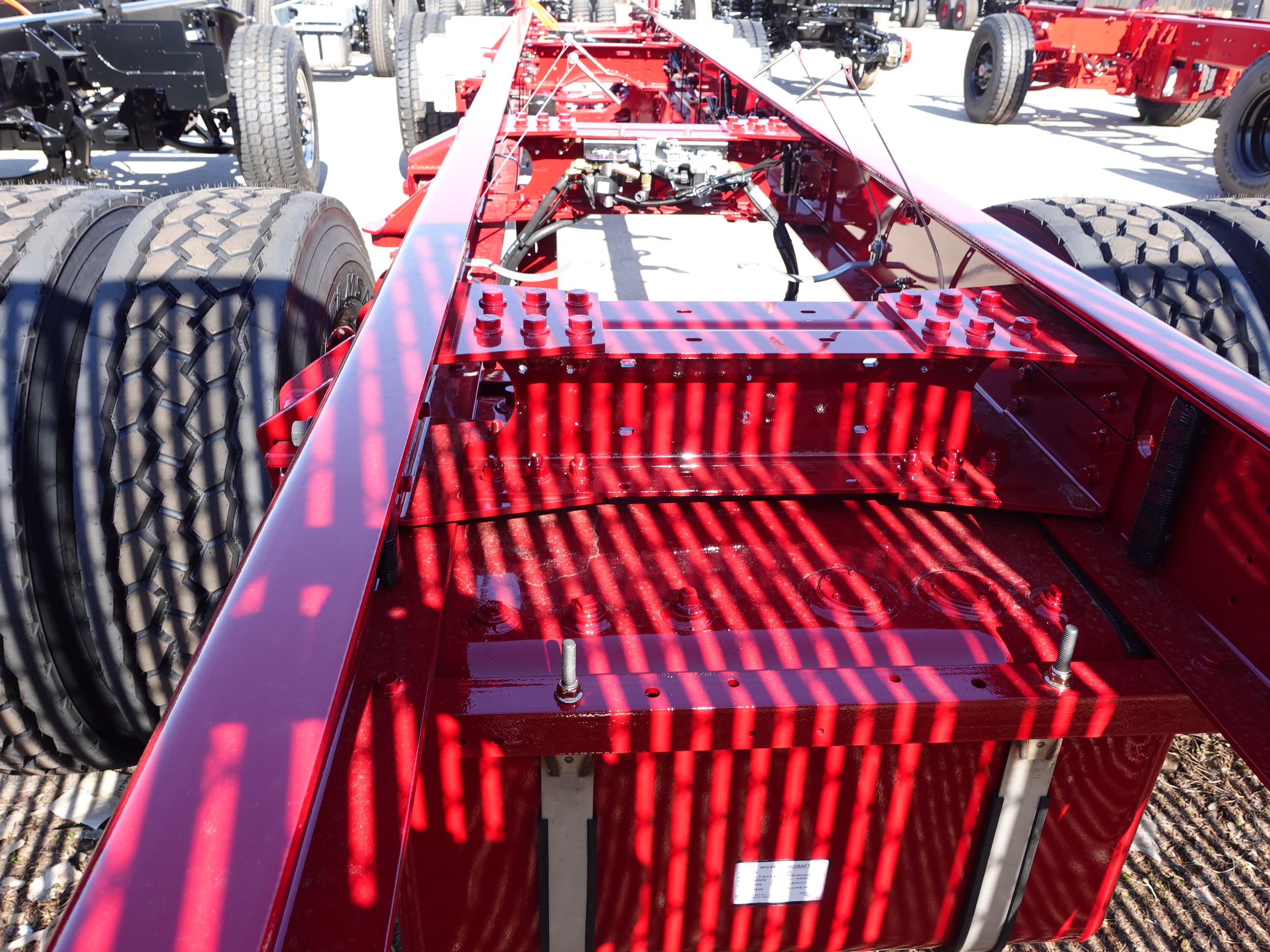

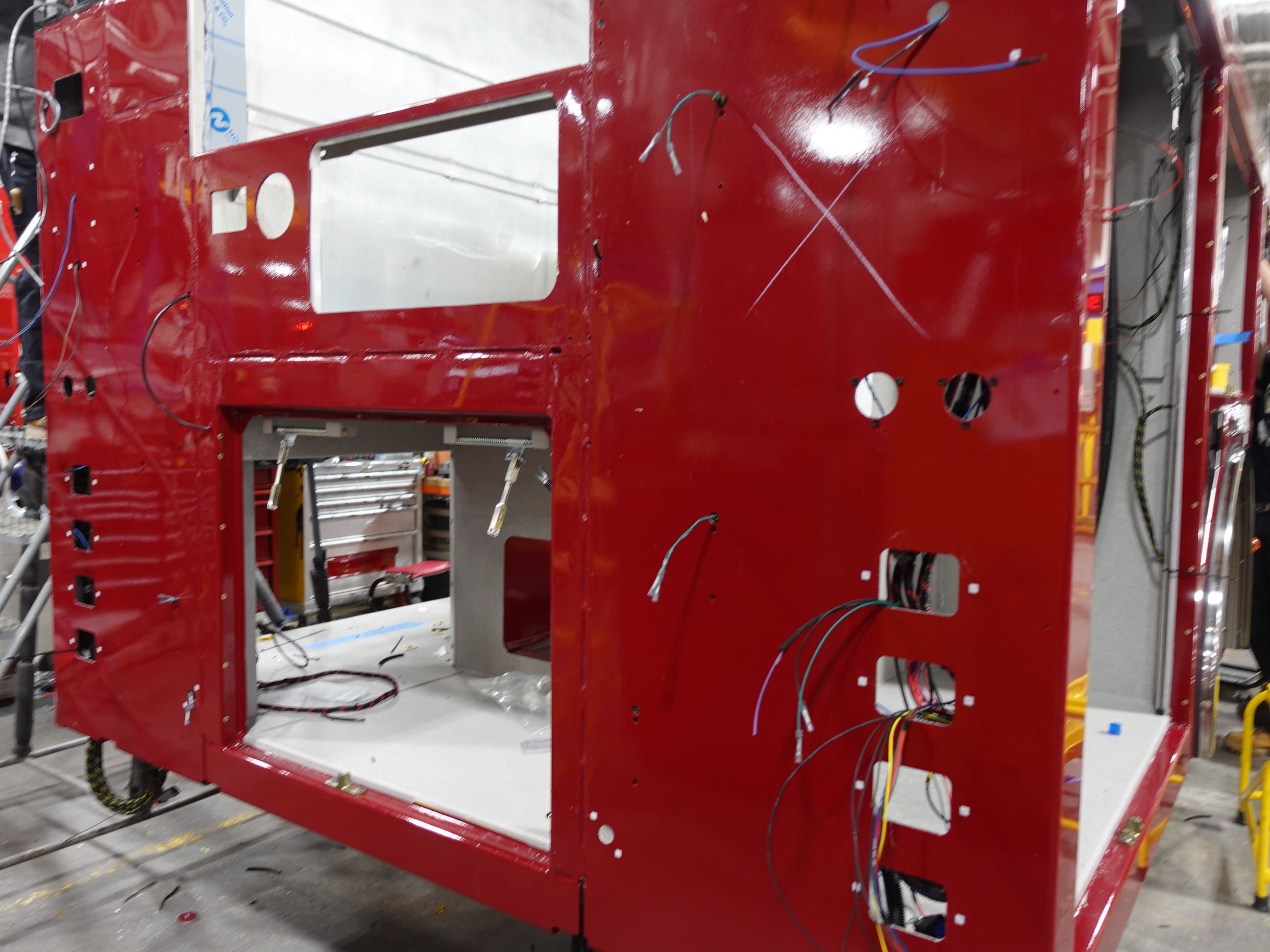

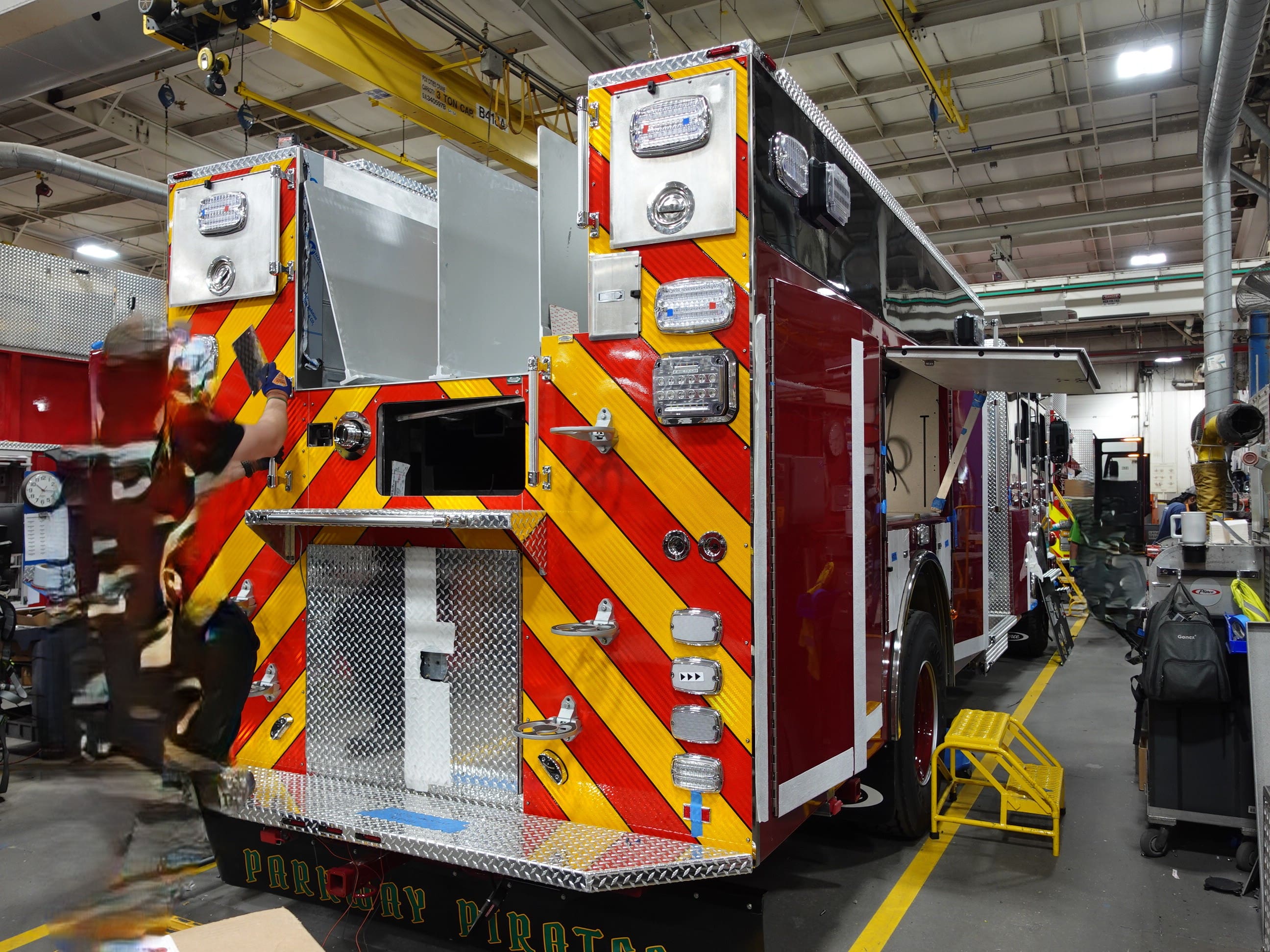

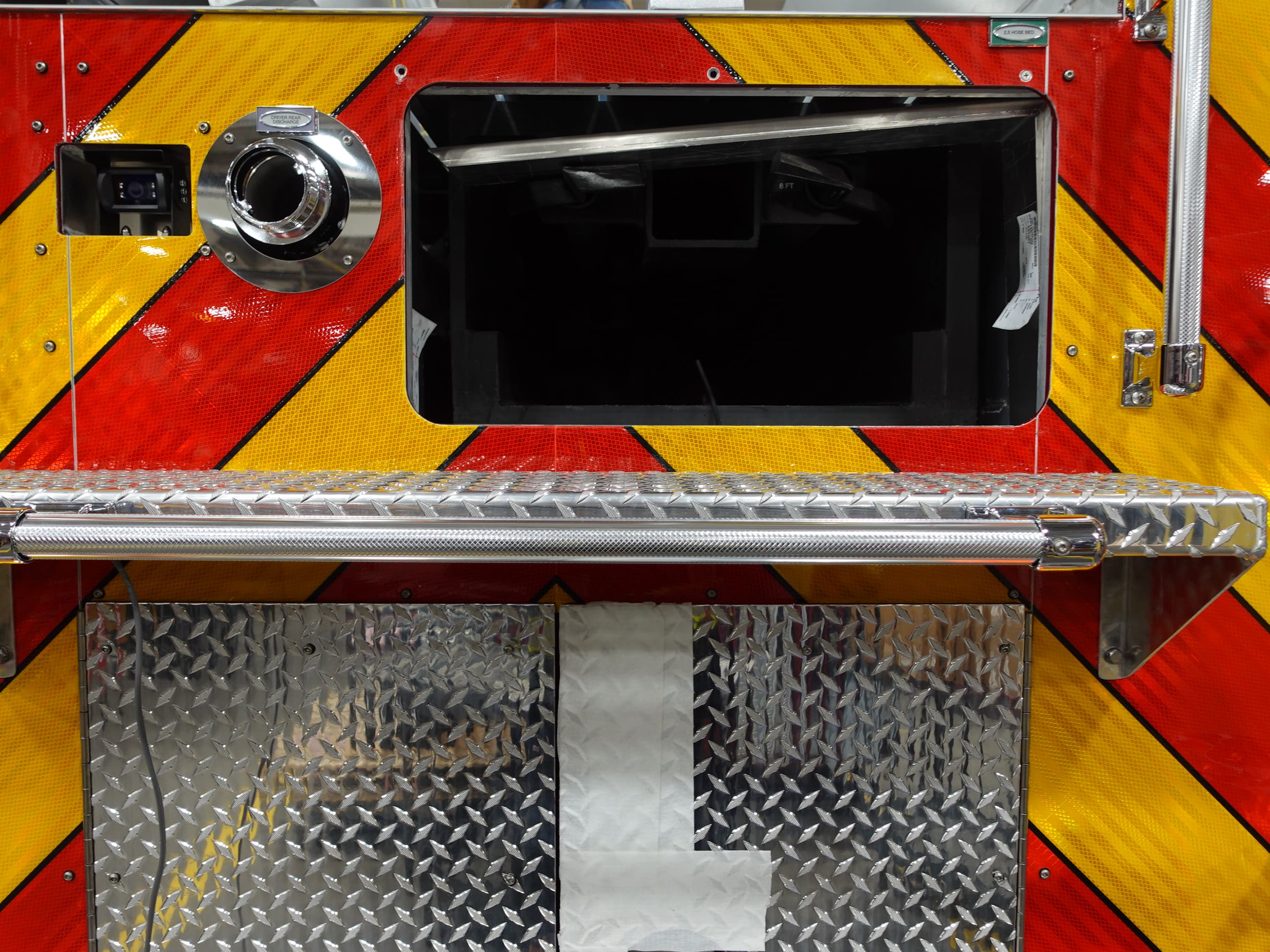

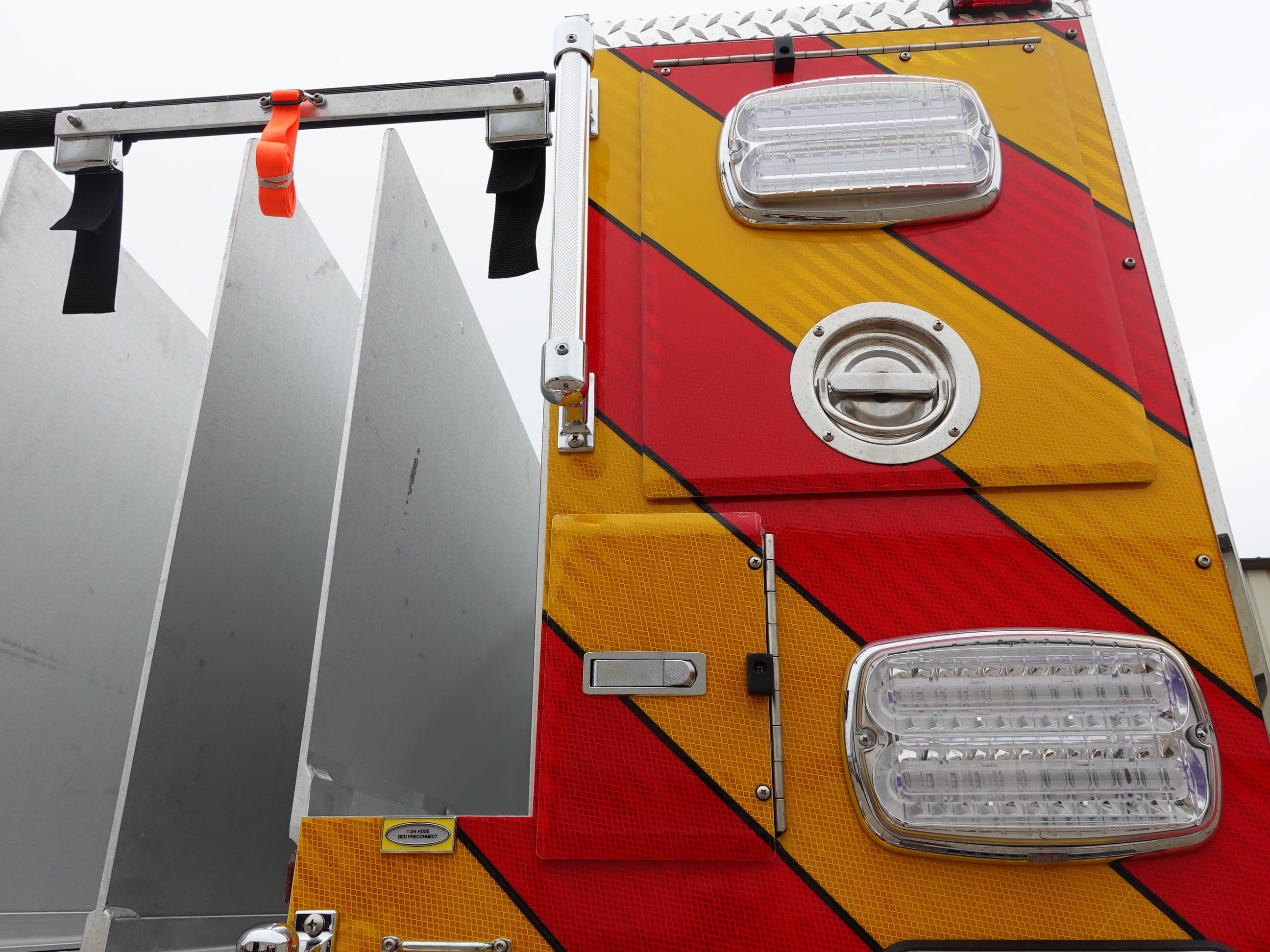

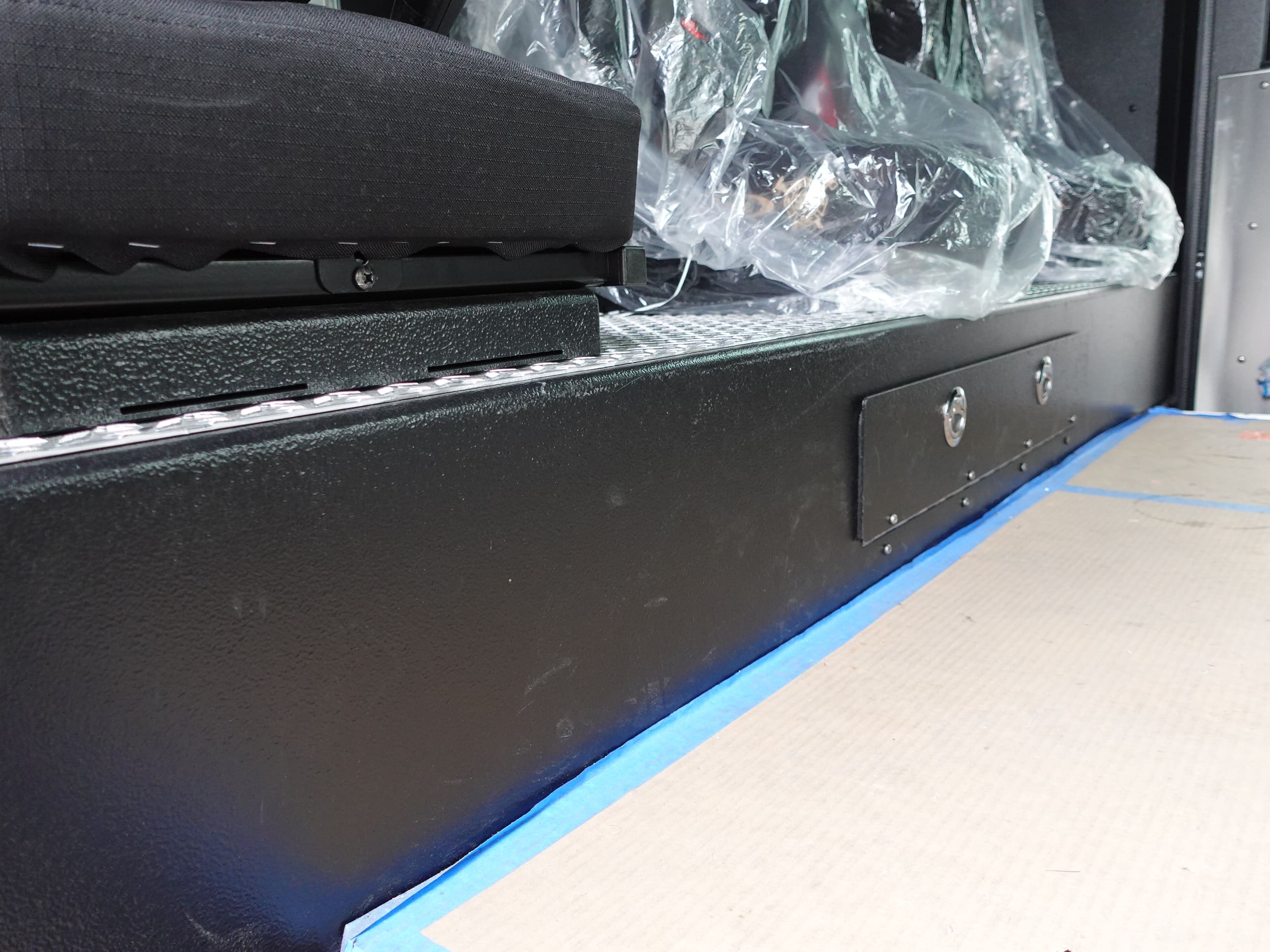

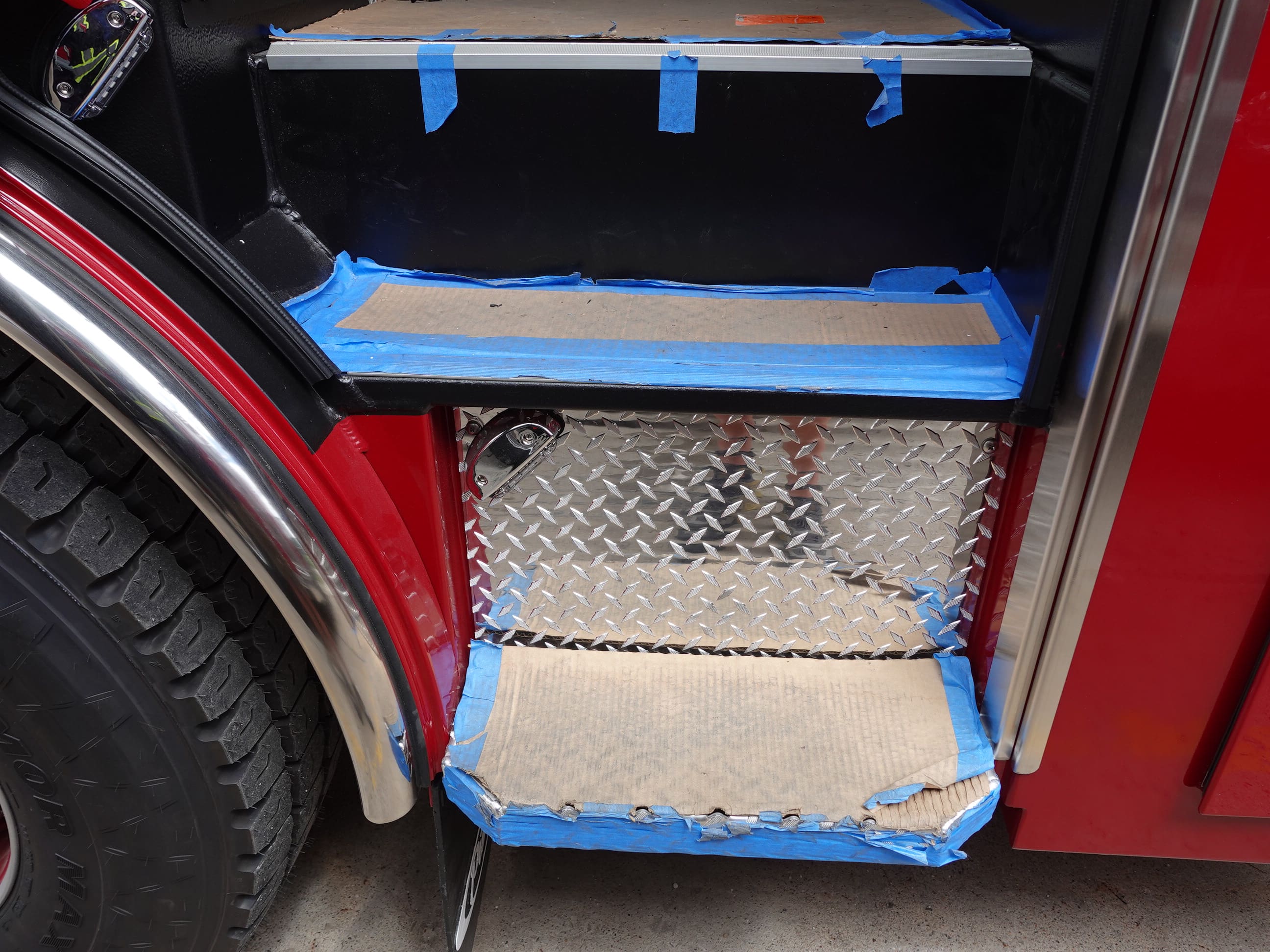

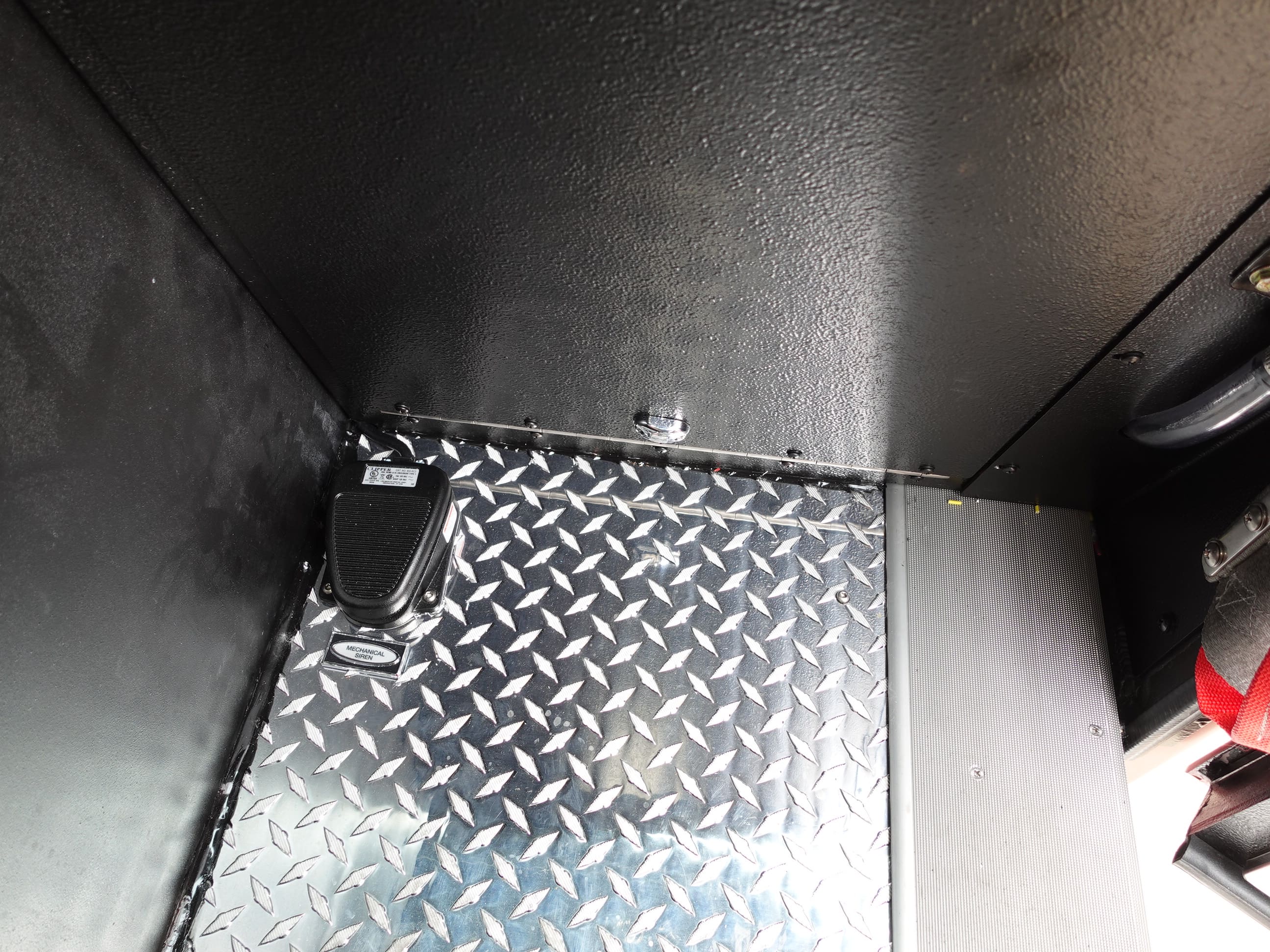

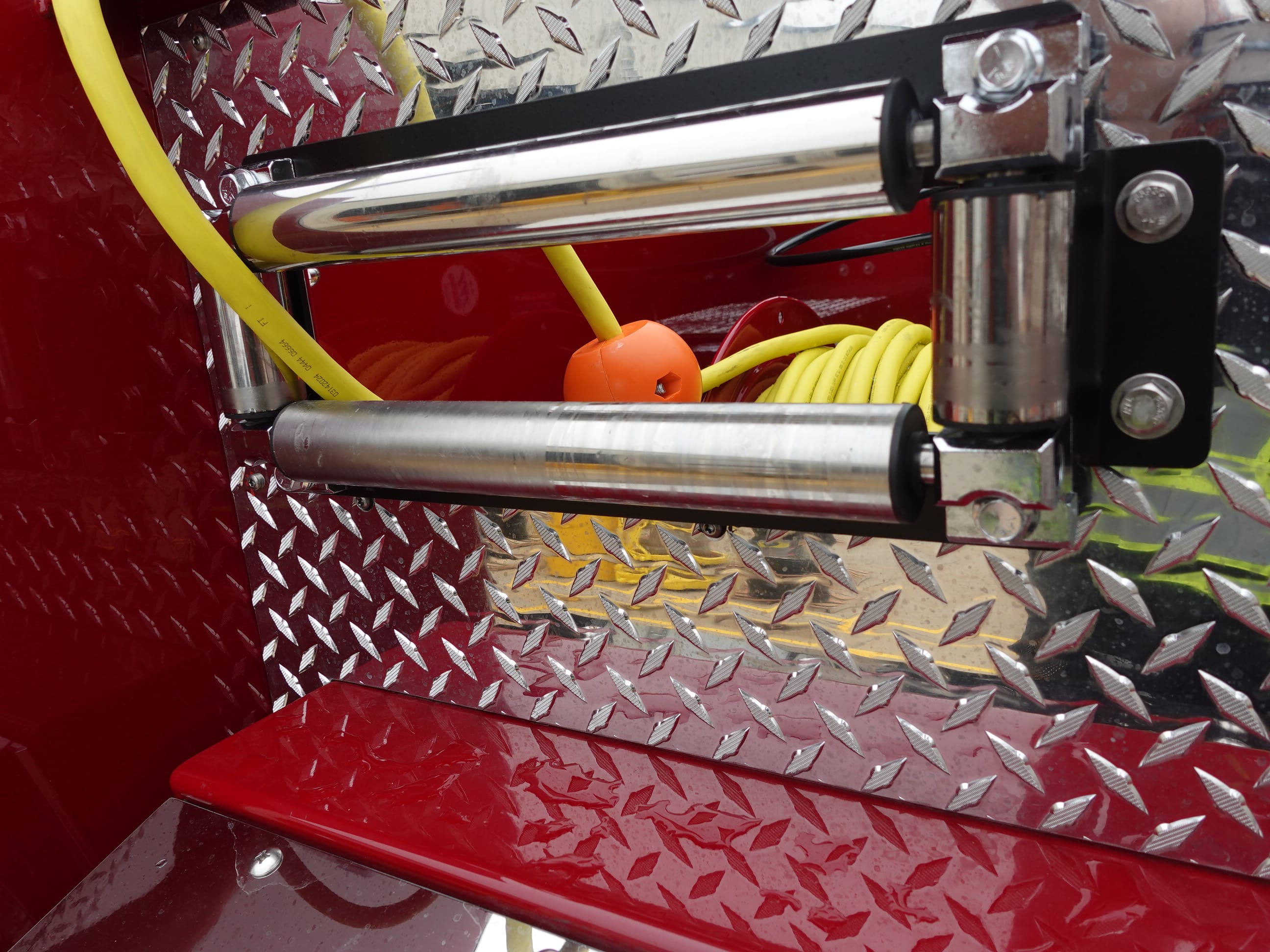

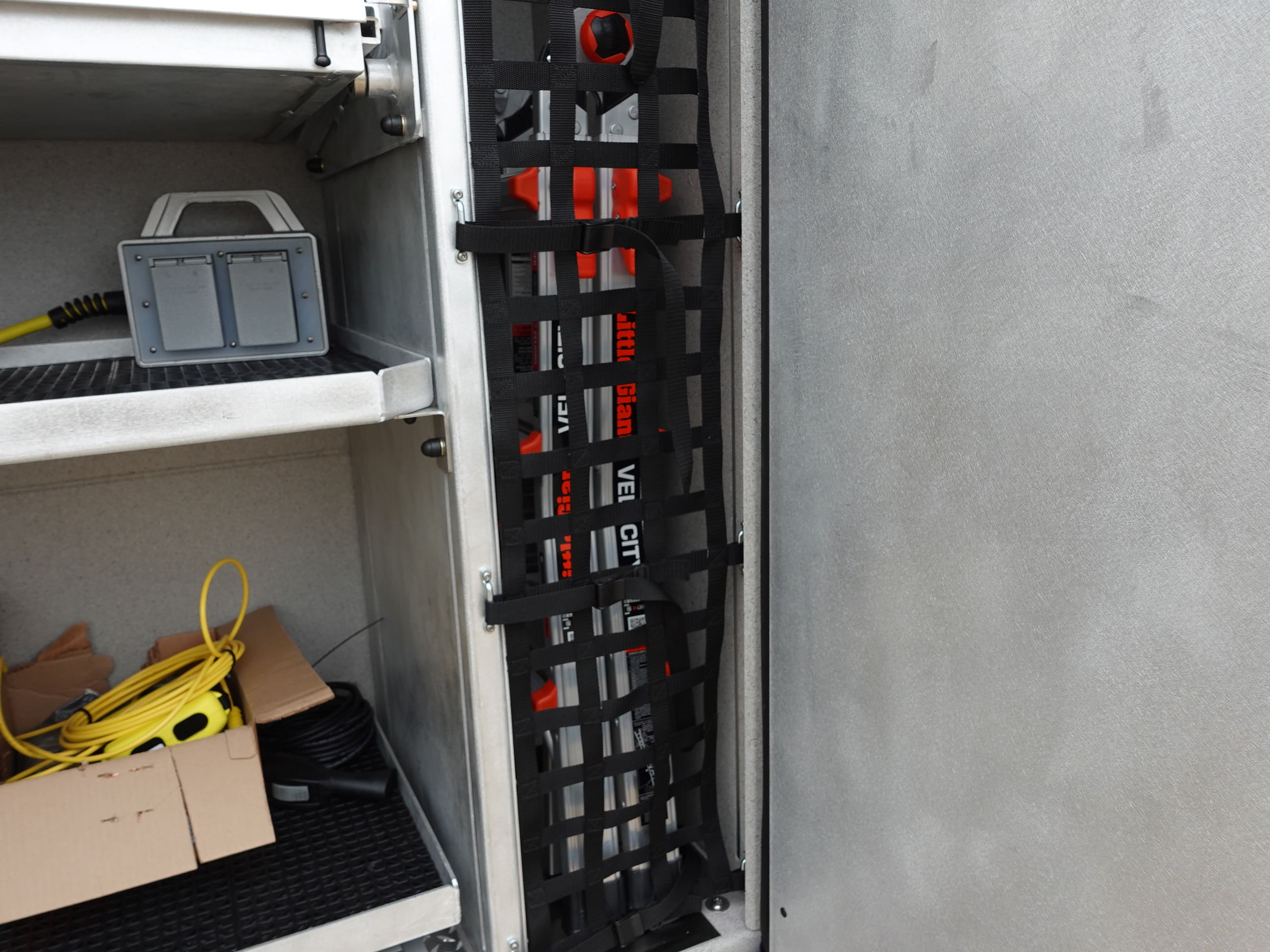

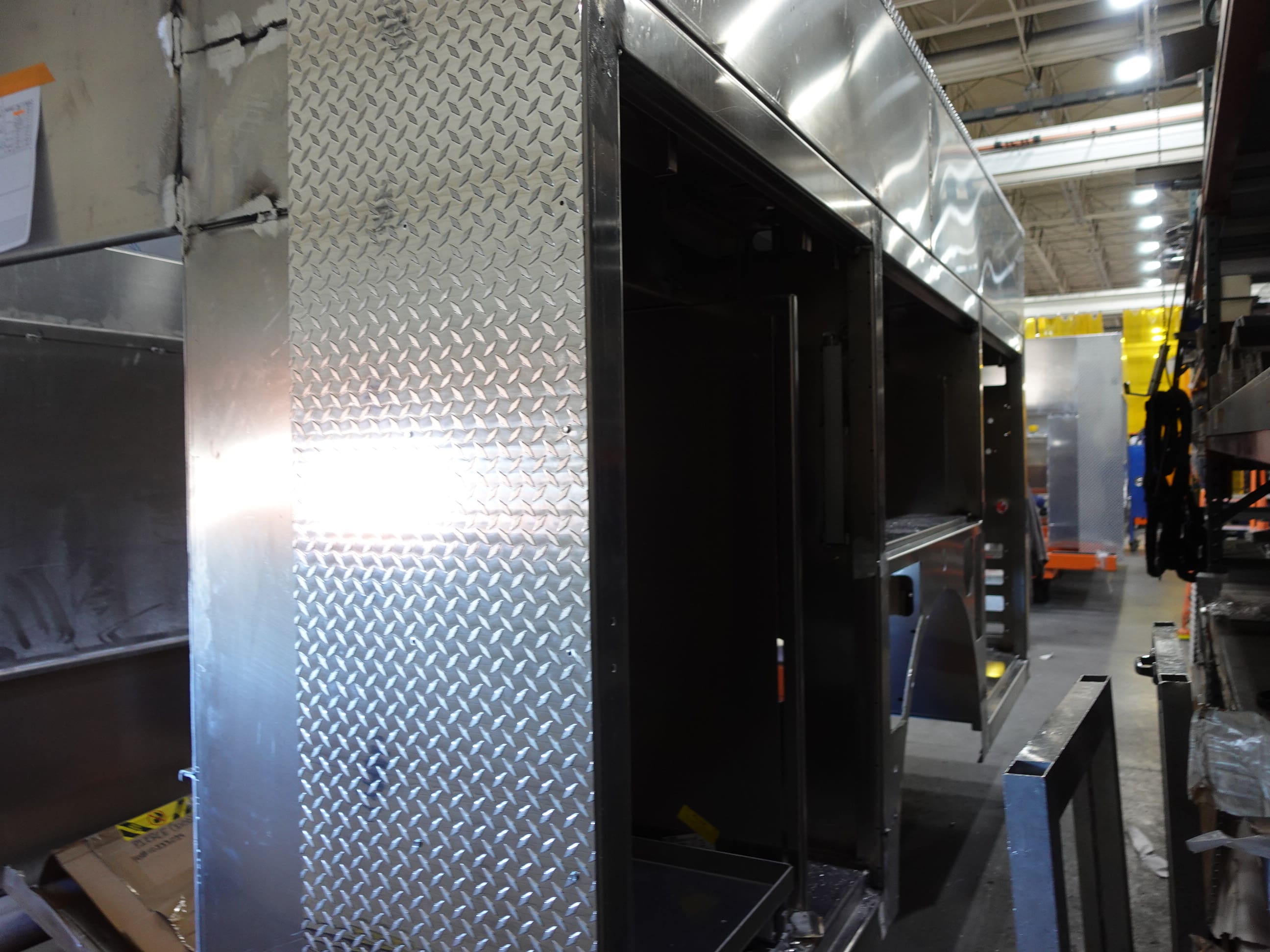

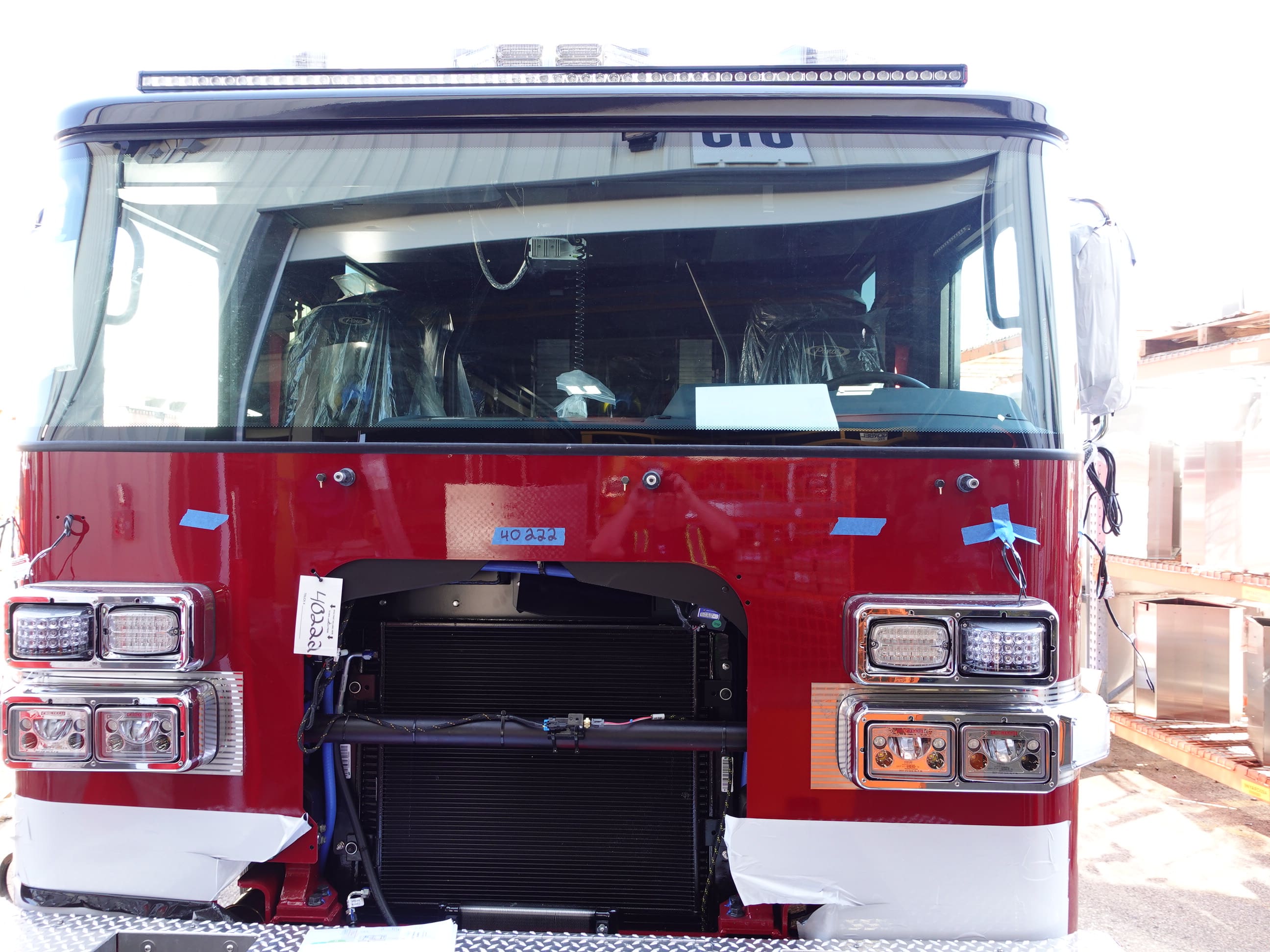

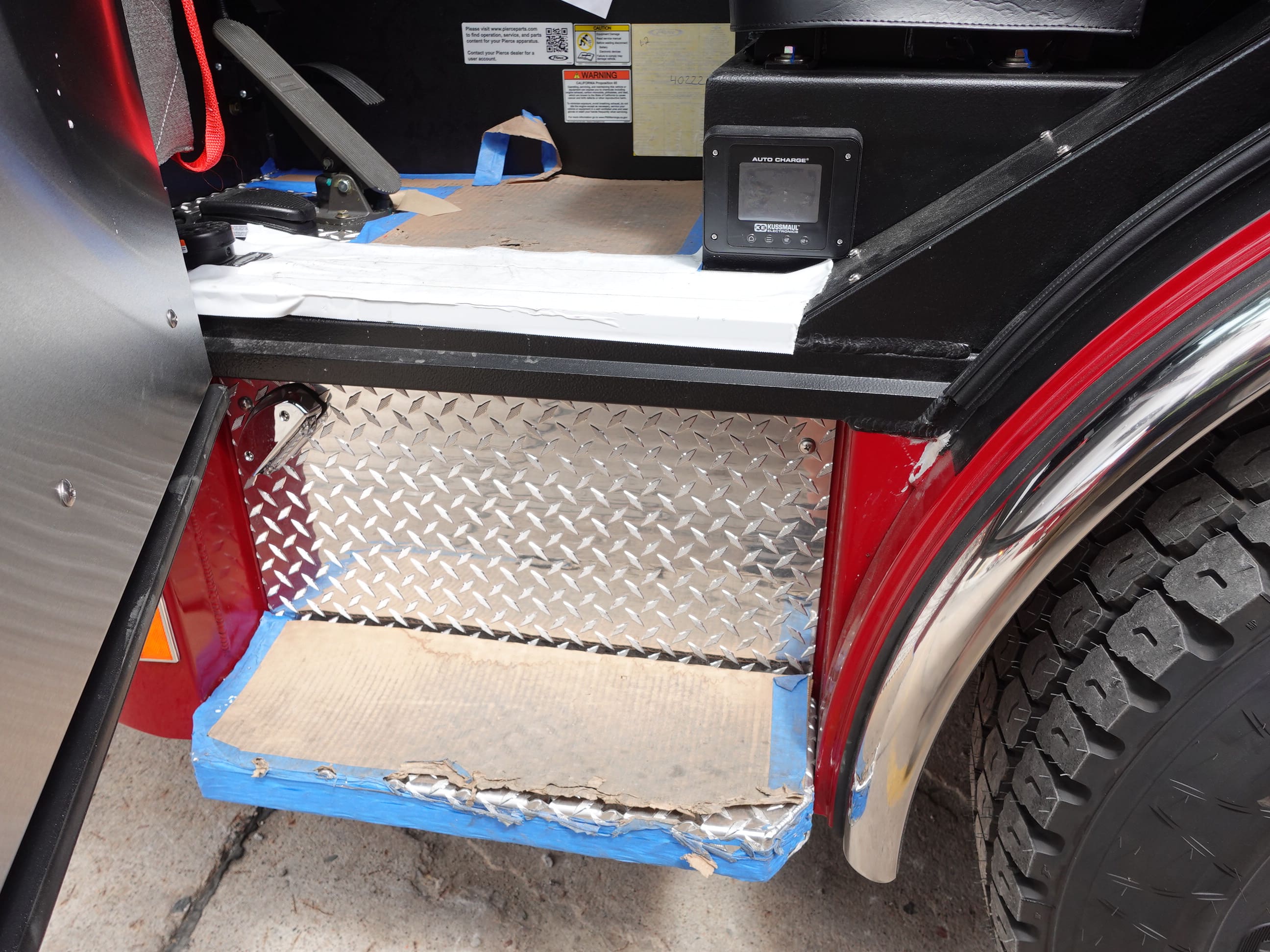

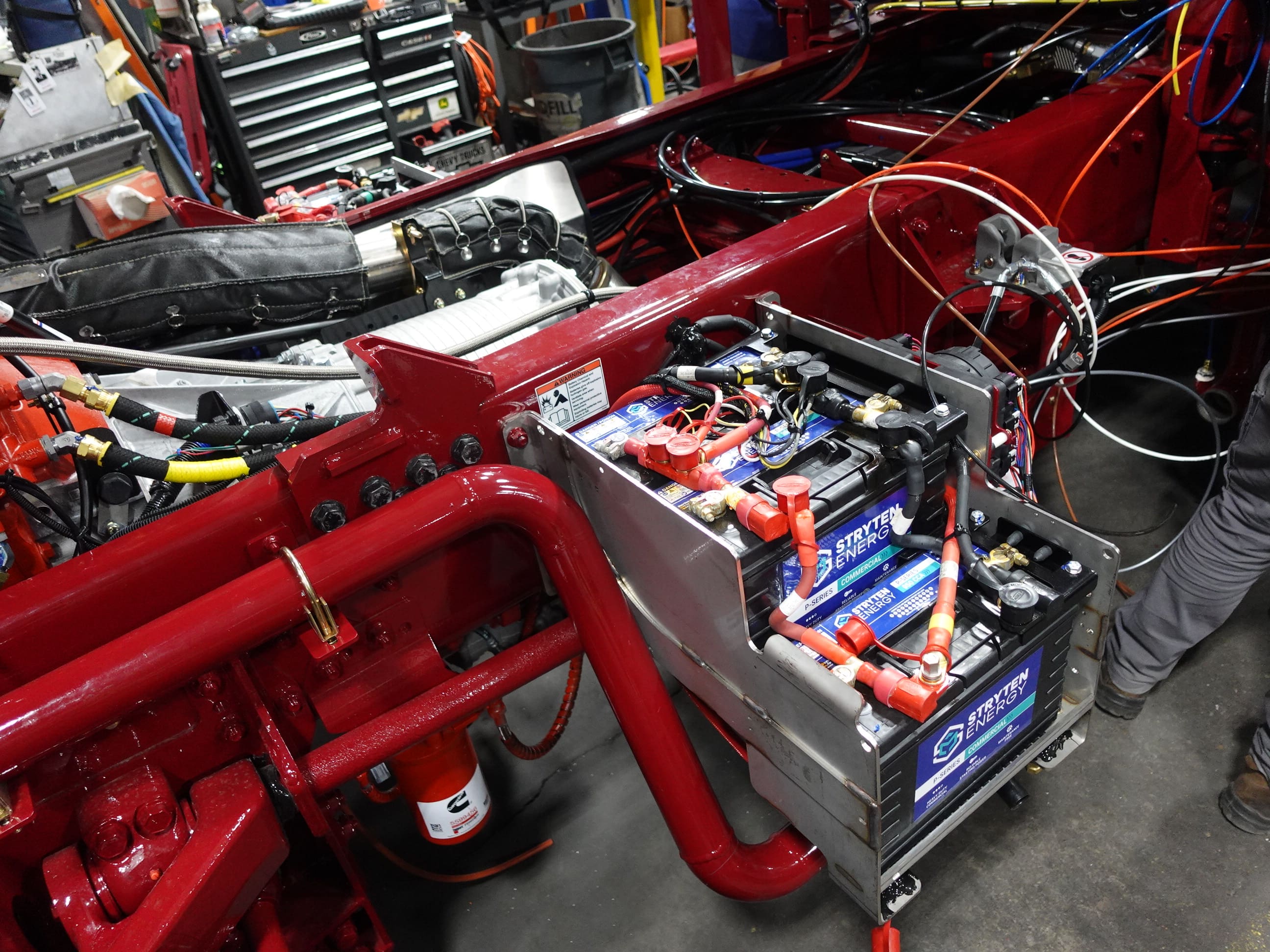

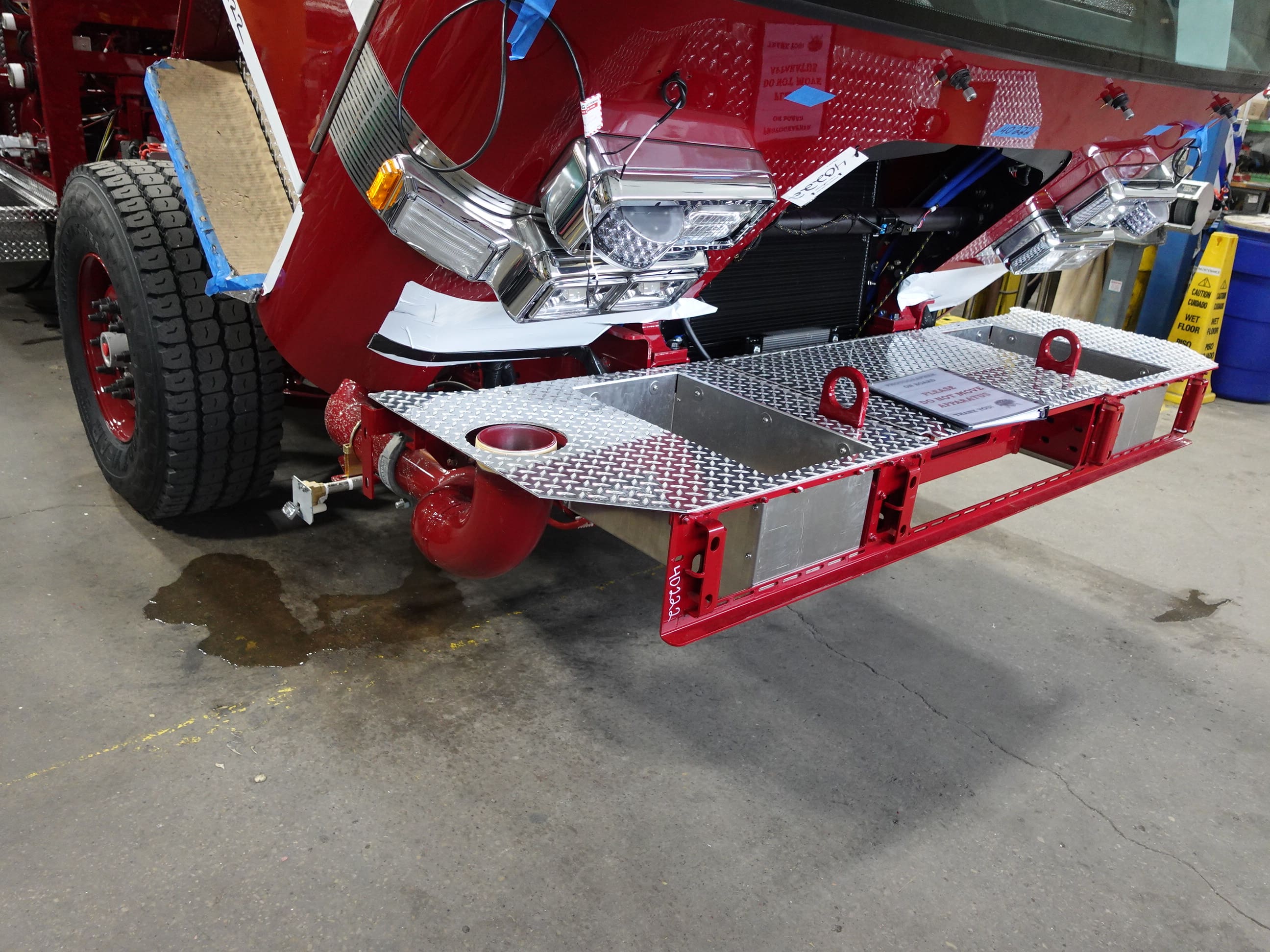

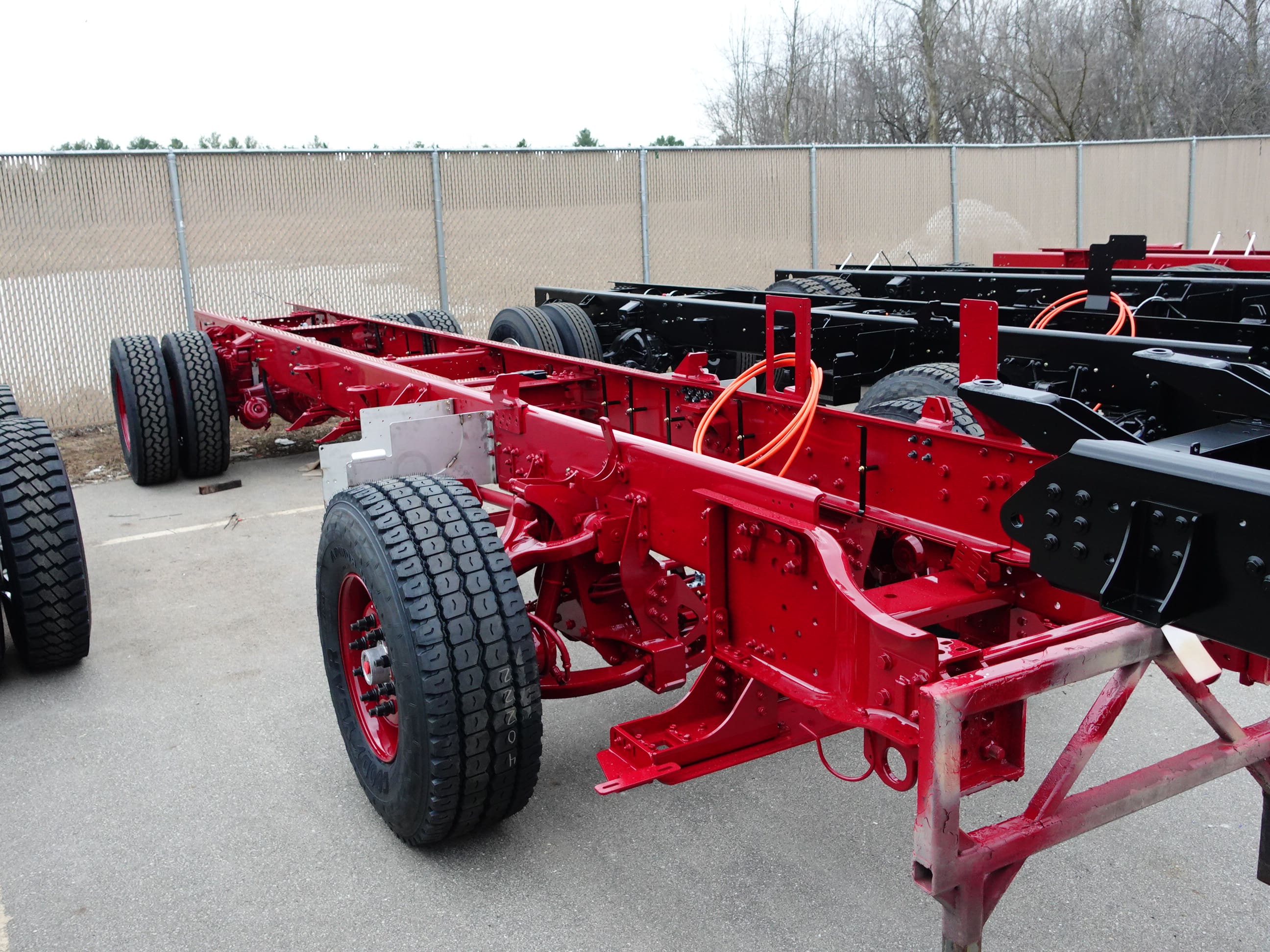

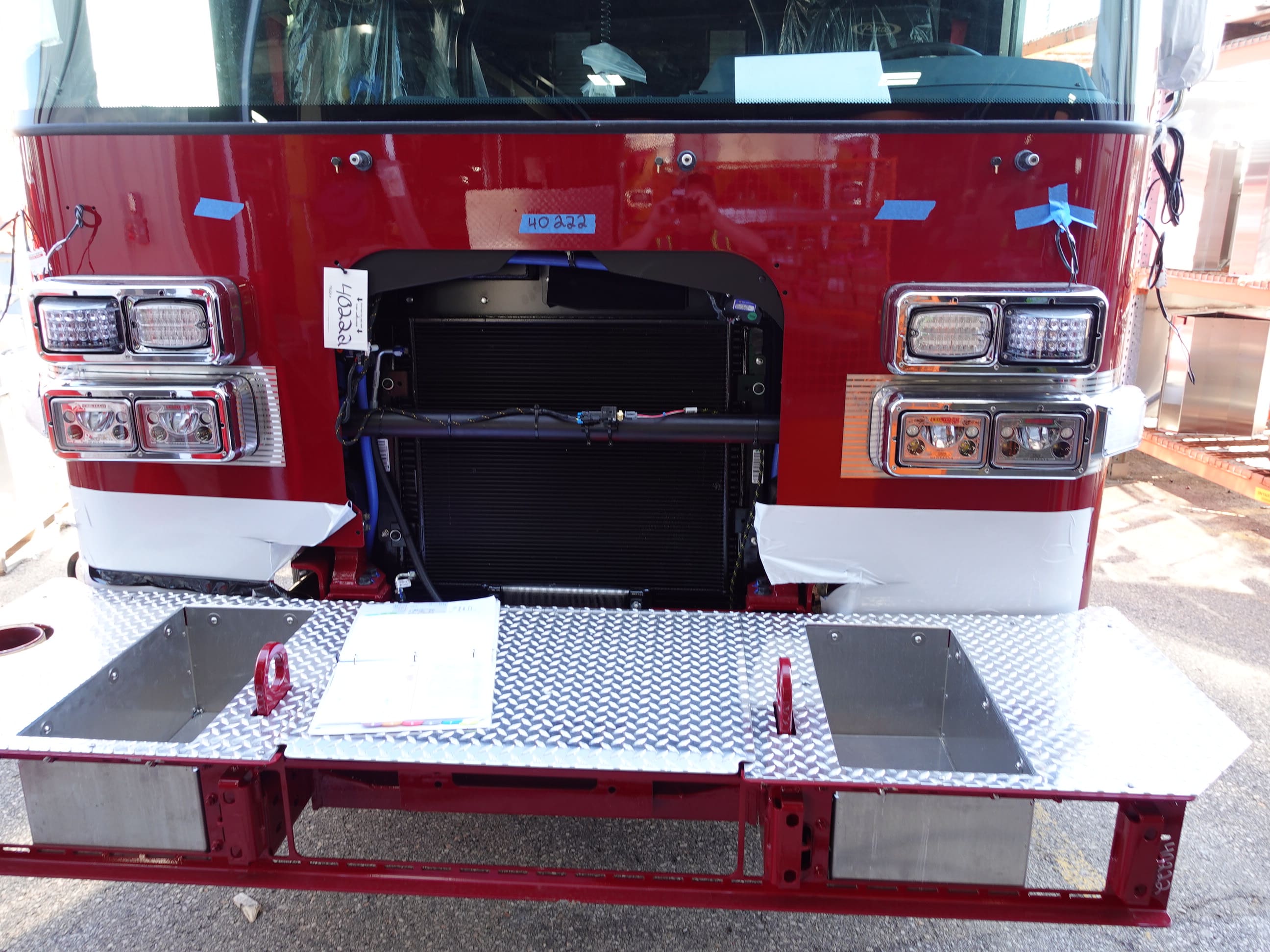

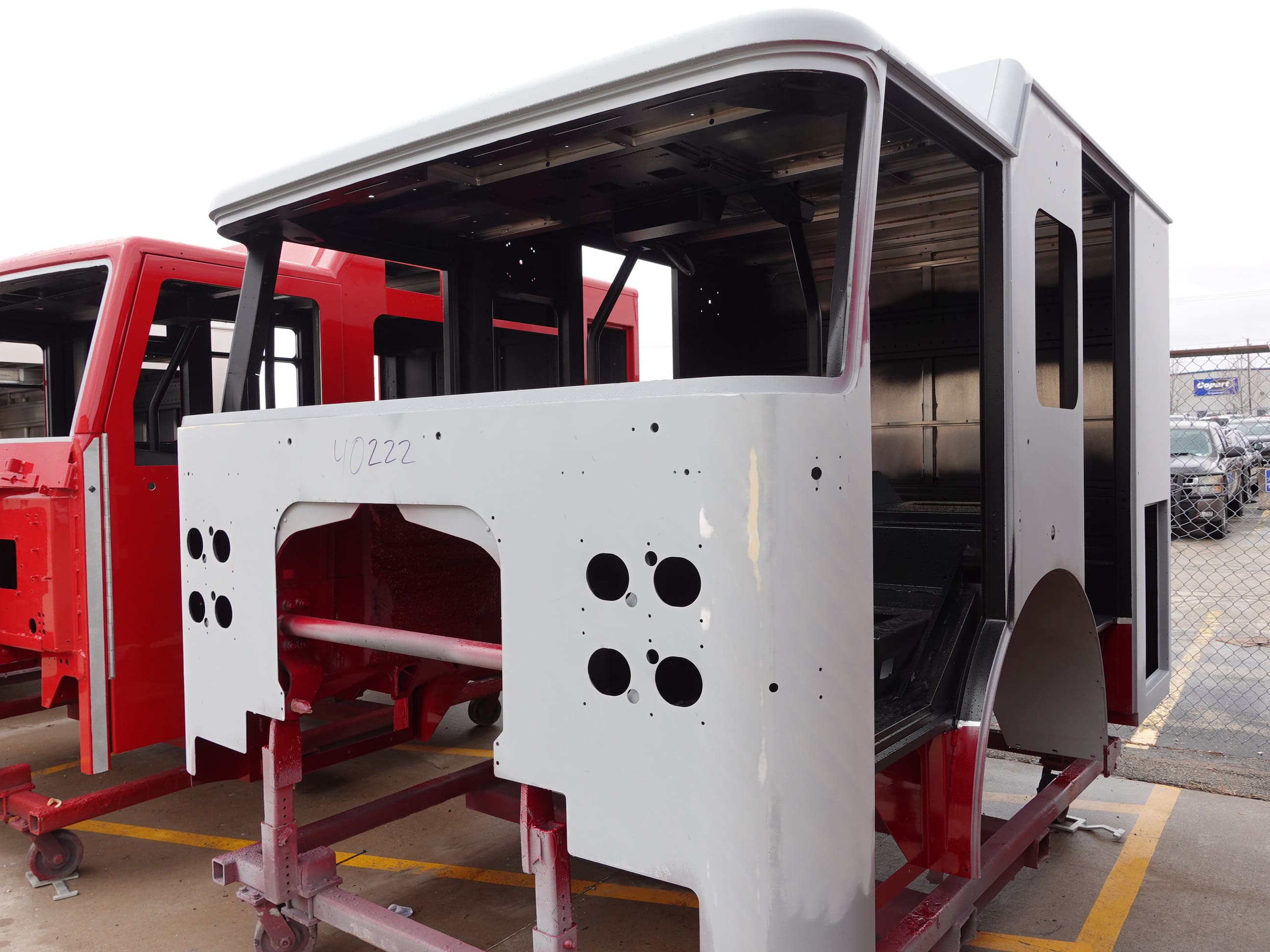

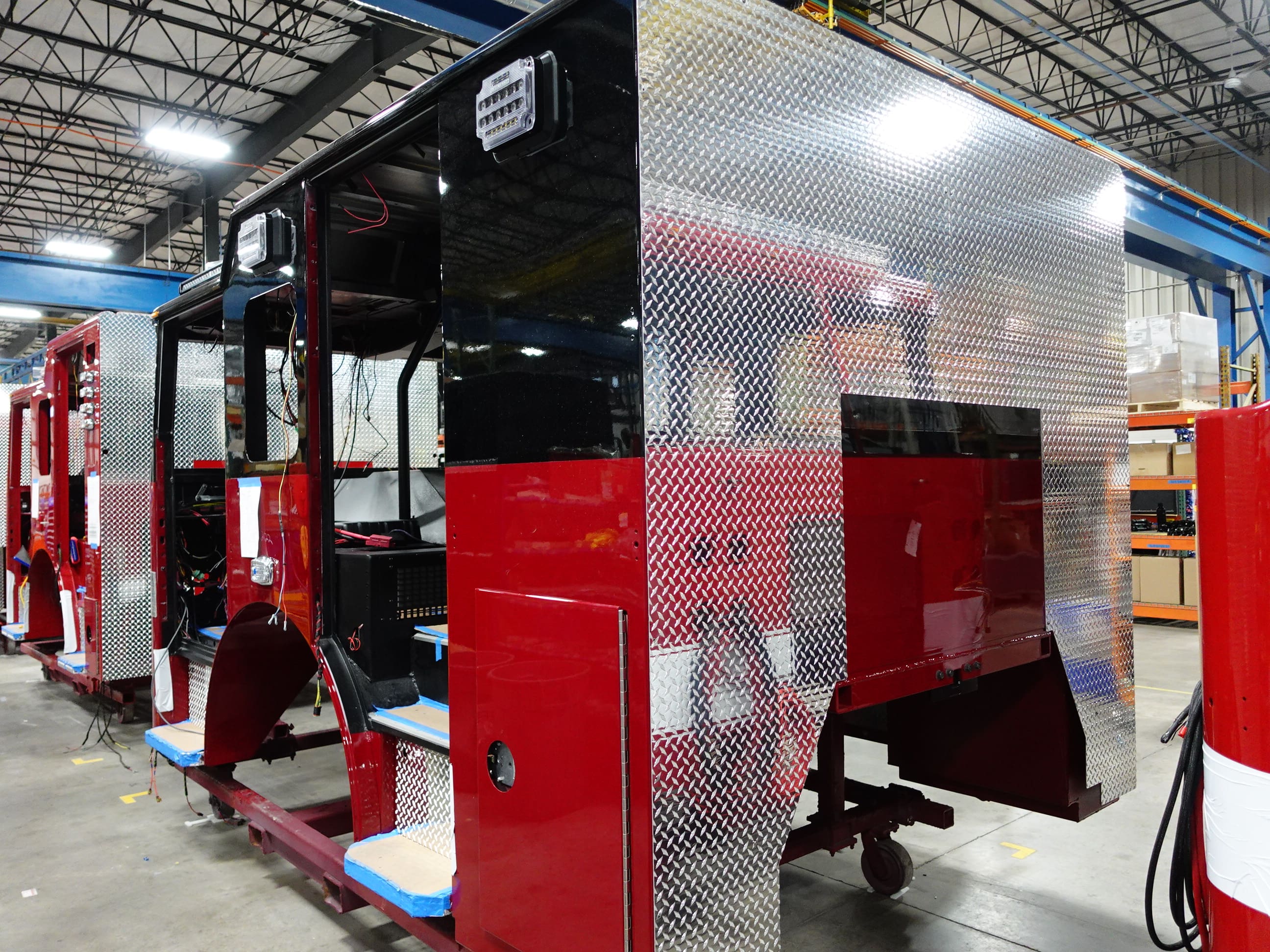

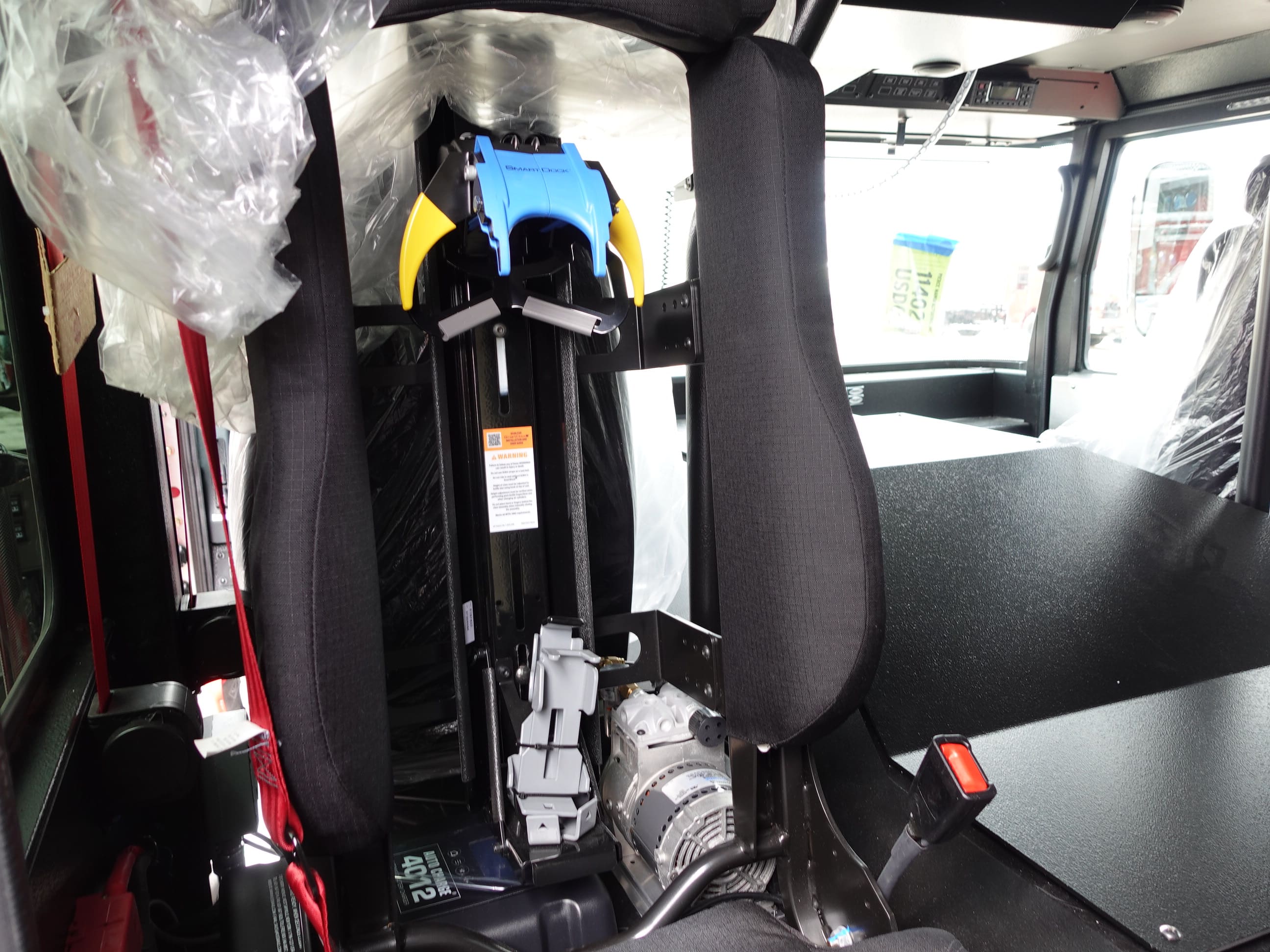

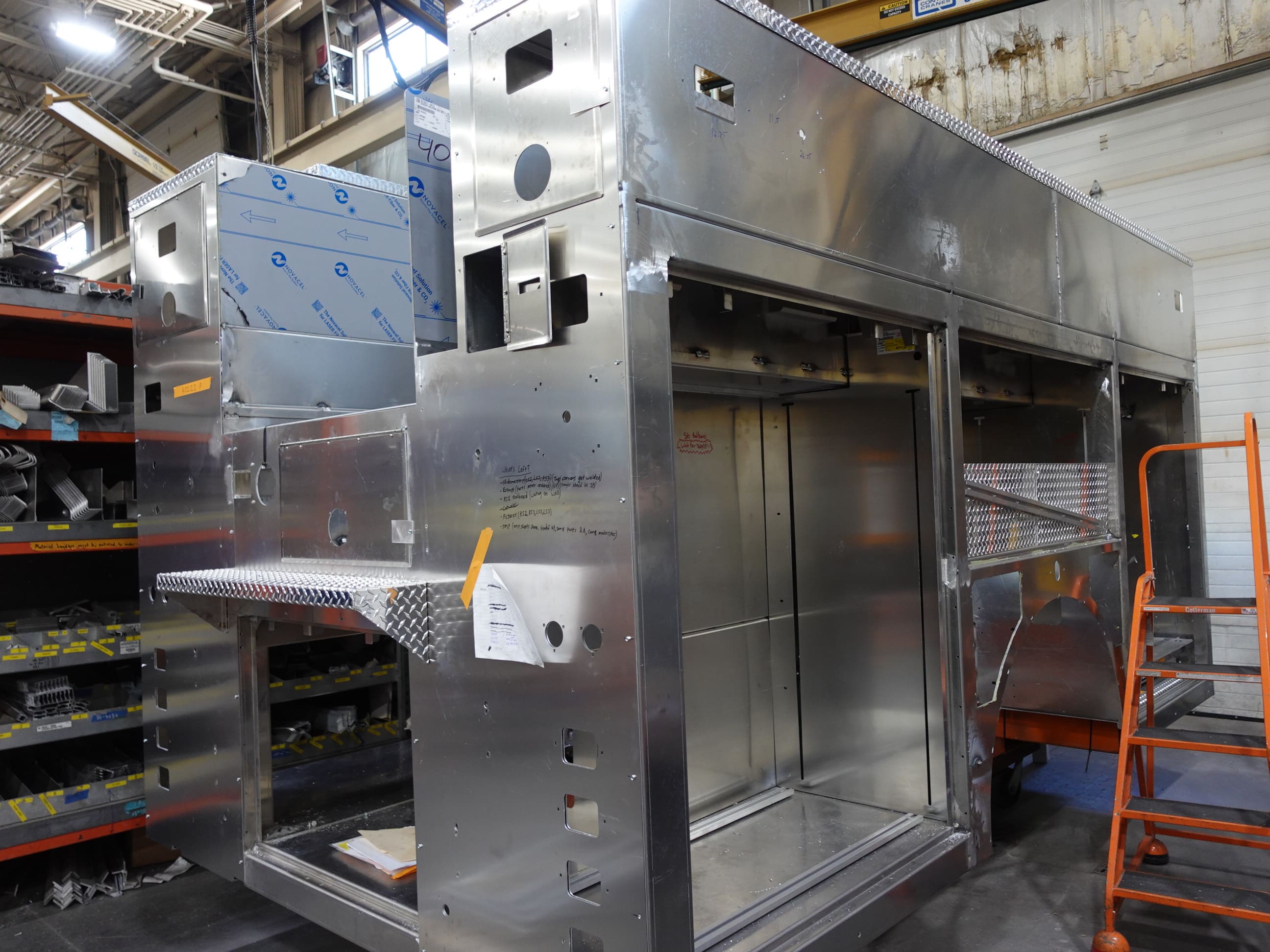

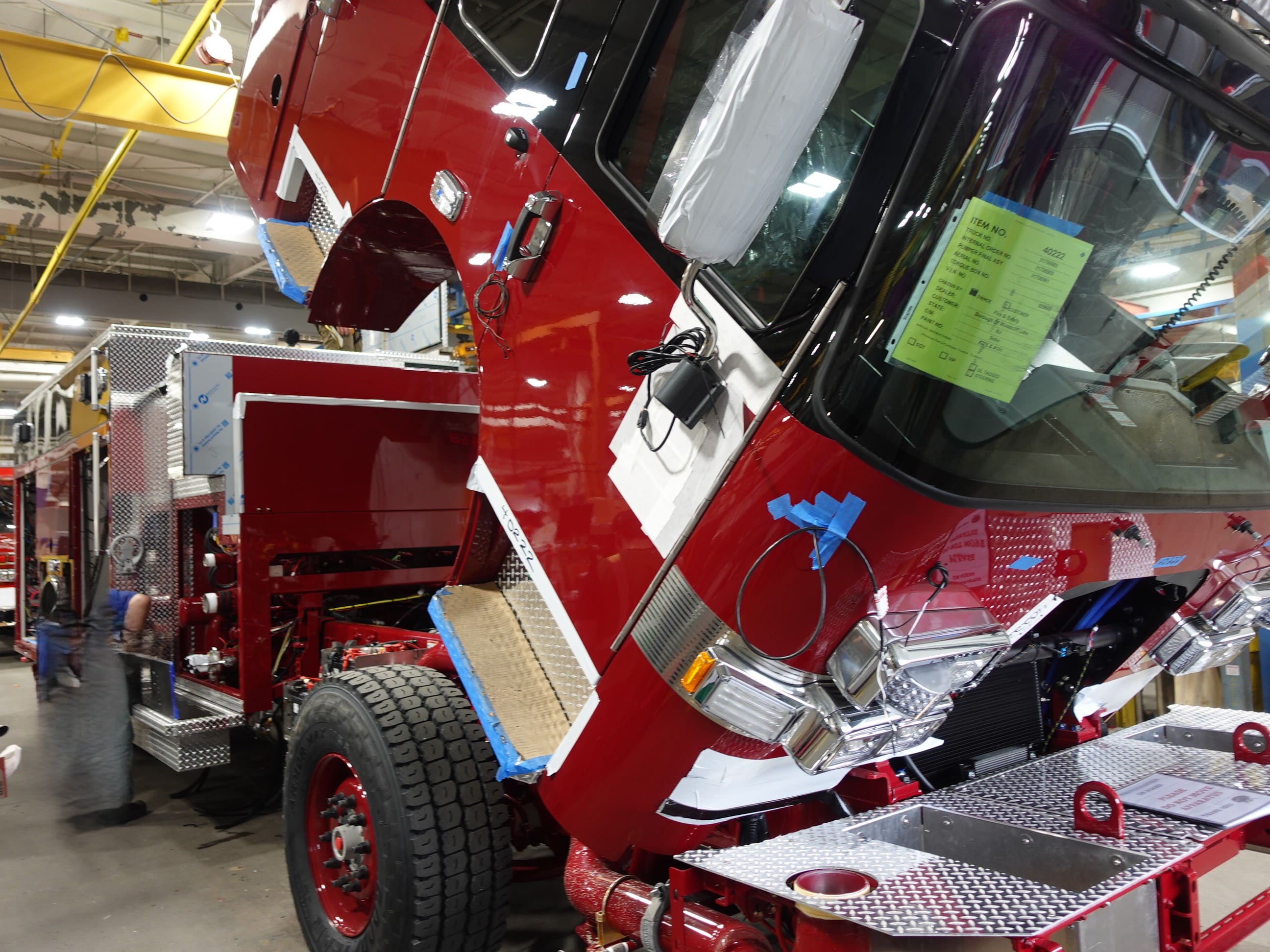

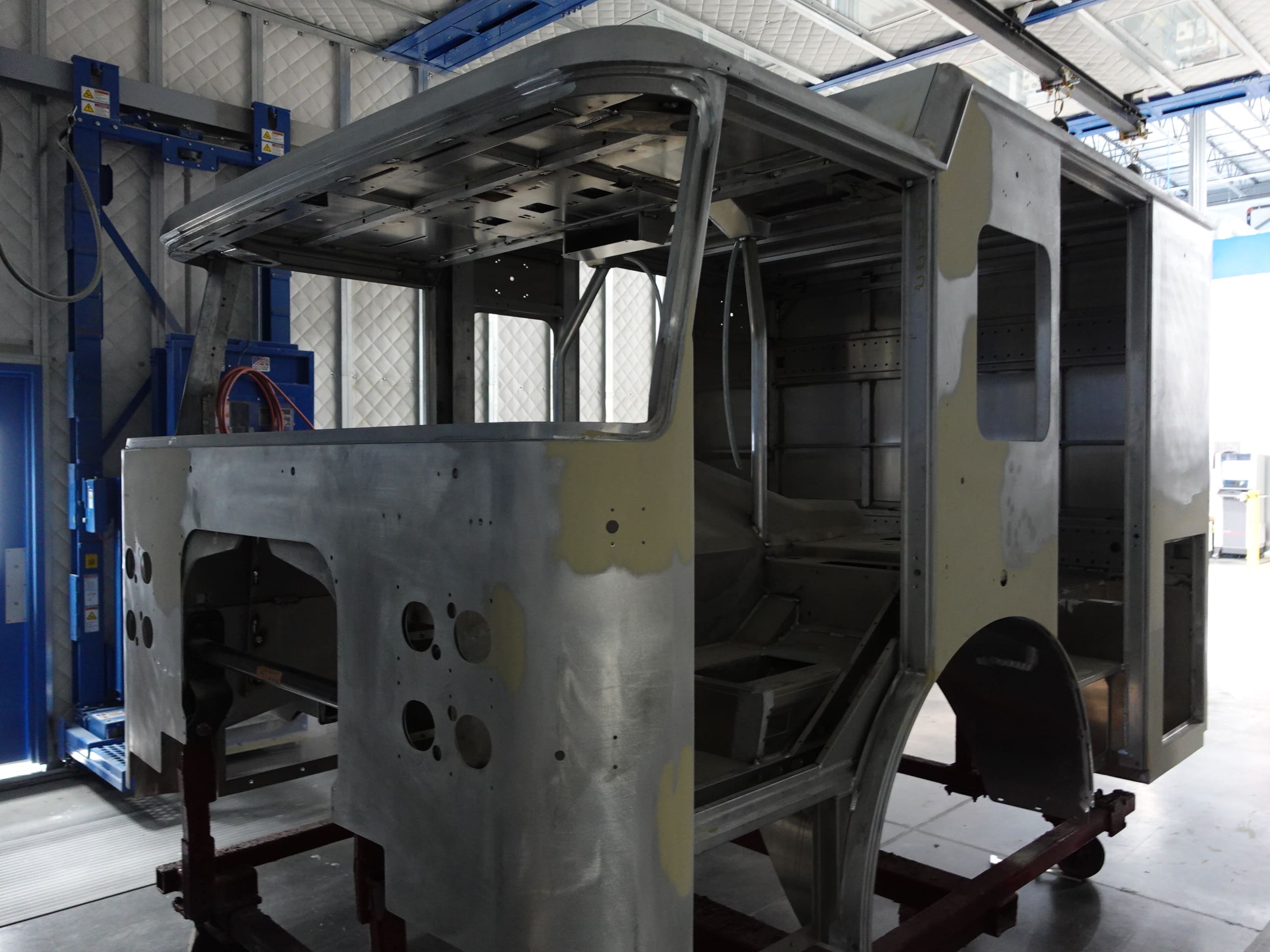

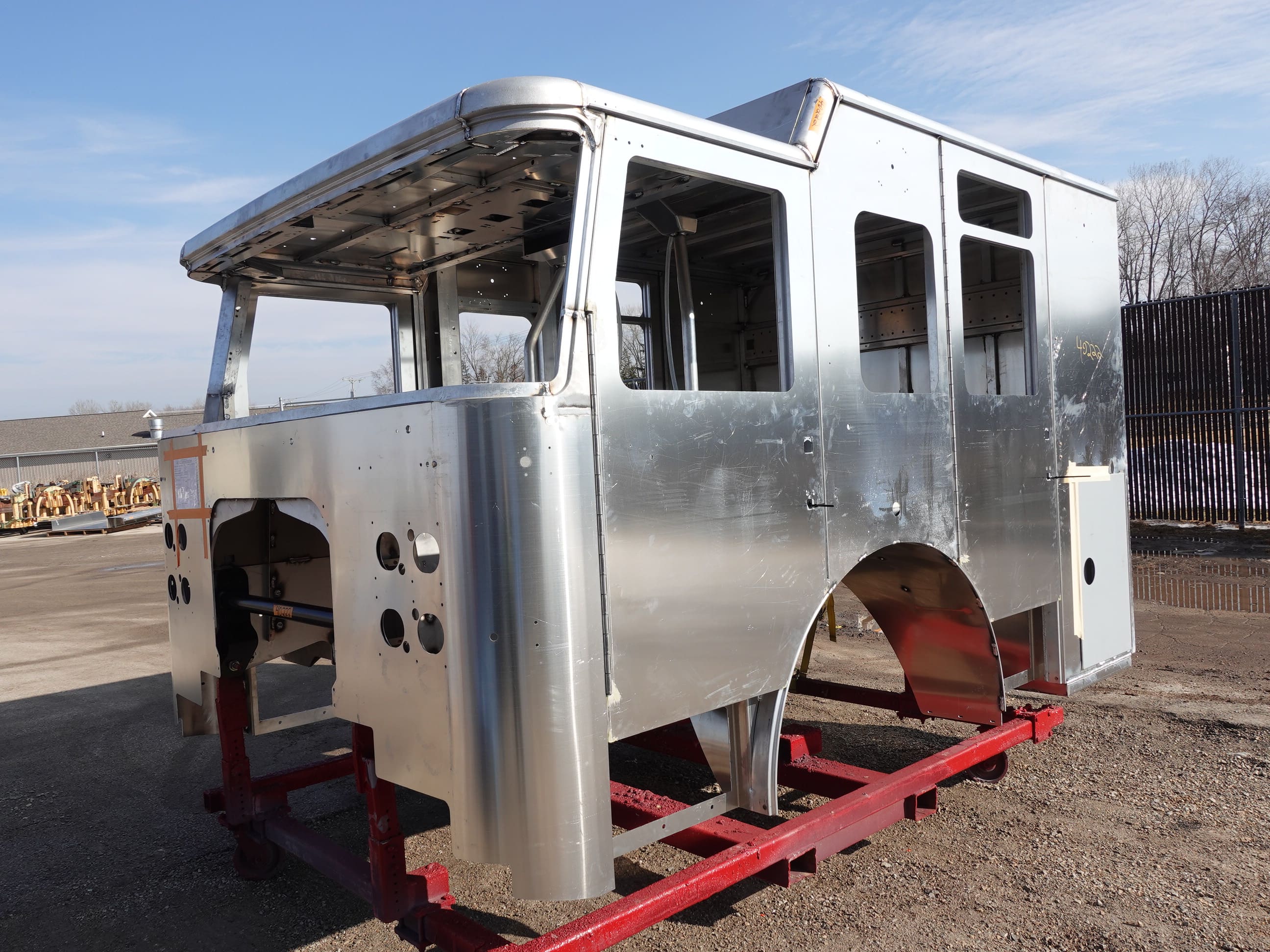

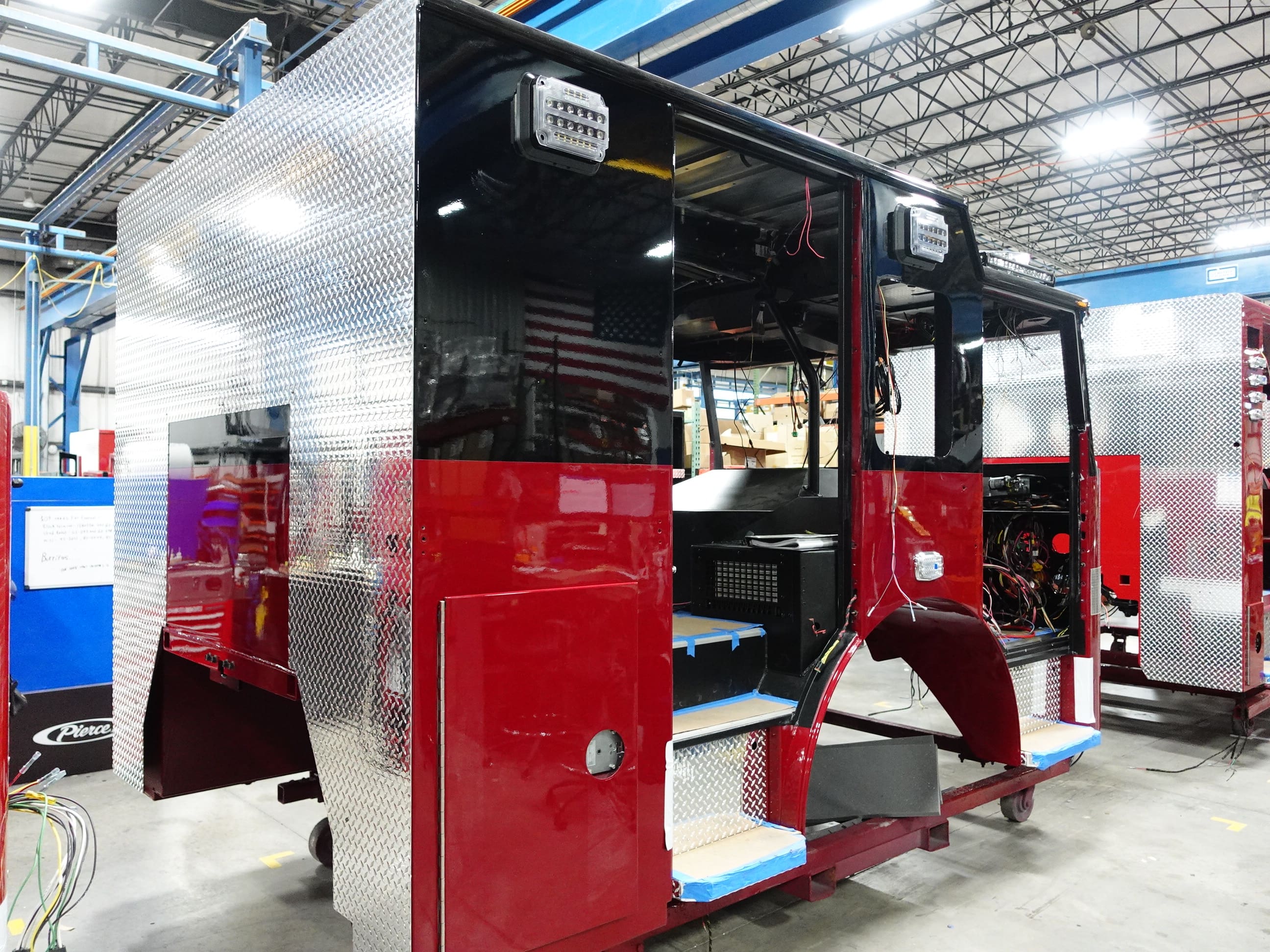

In this report, the cab and pump house were merged with the frame followed by body installation at the start of initial apparatus assembly.

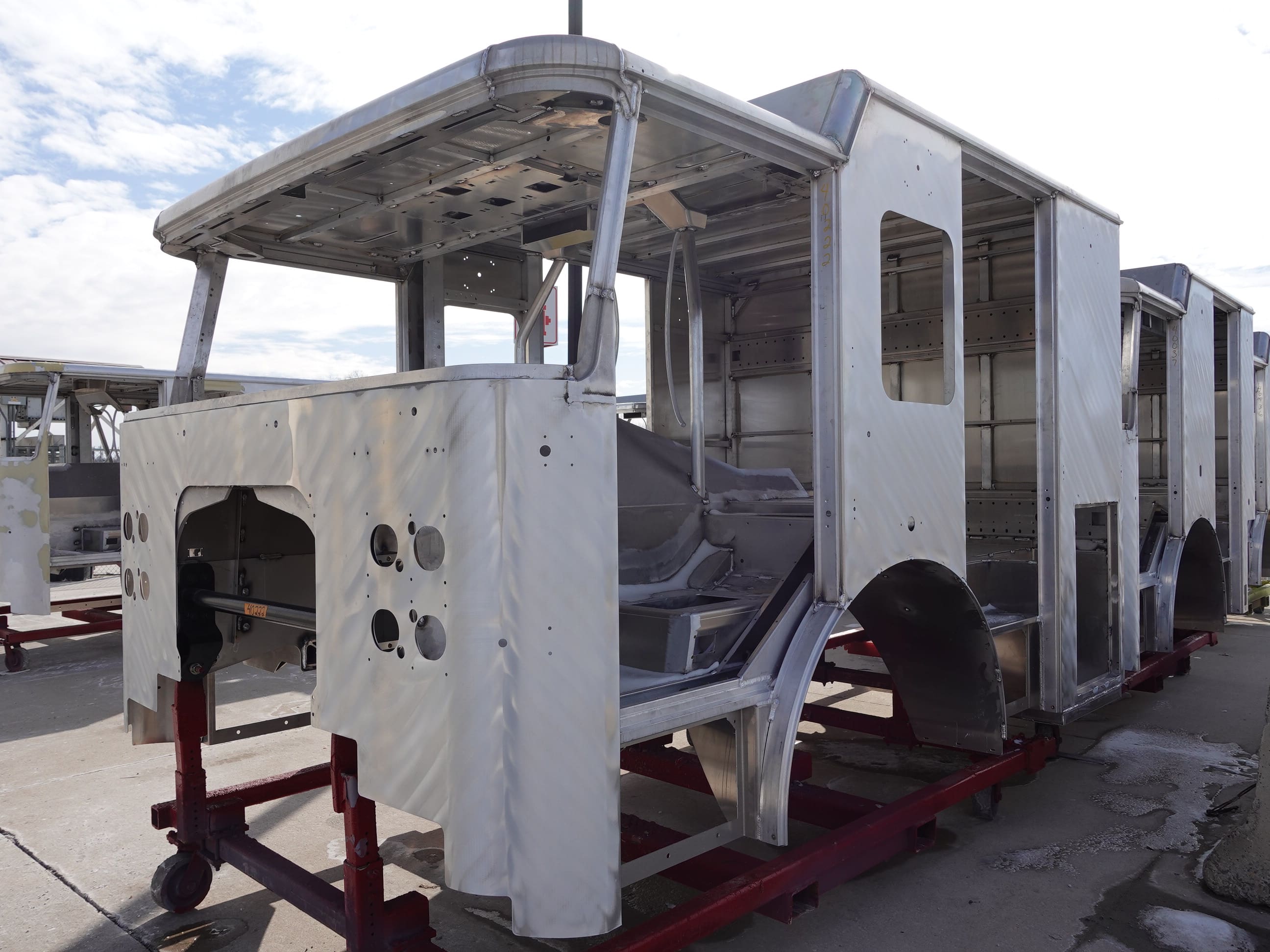

04-10-26

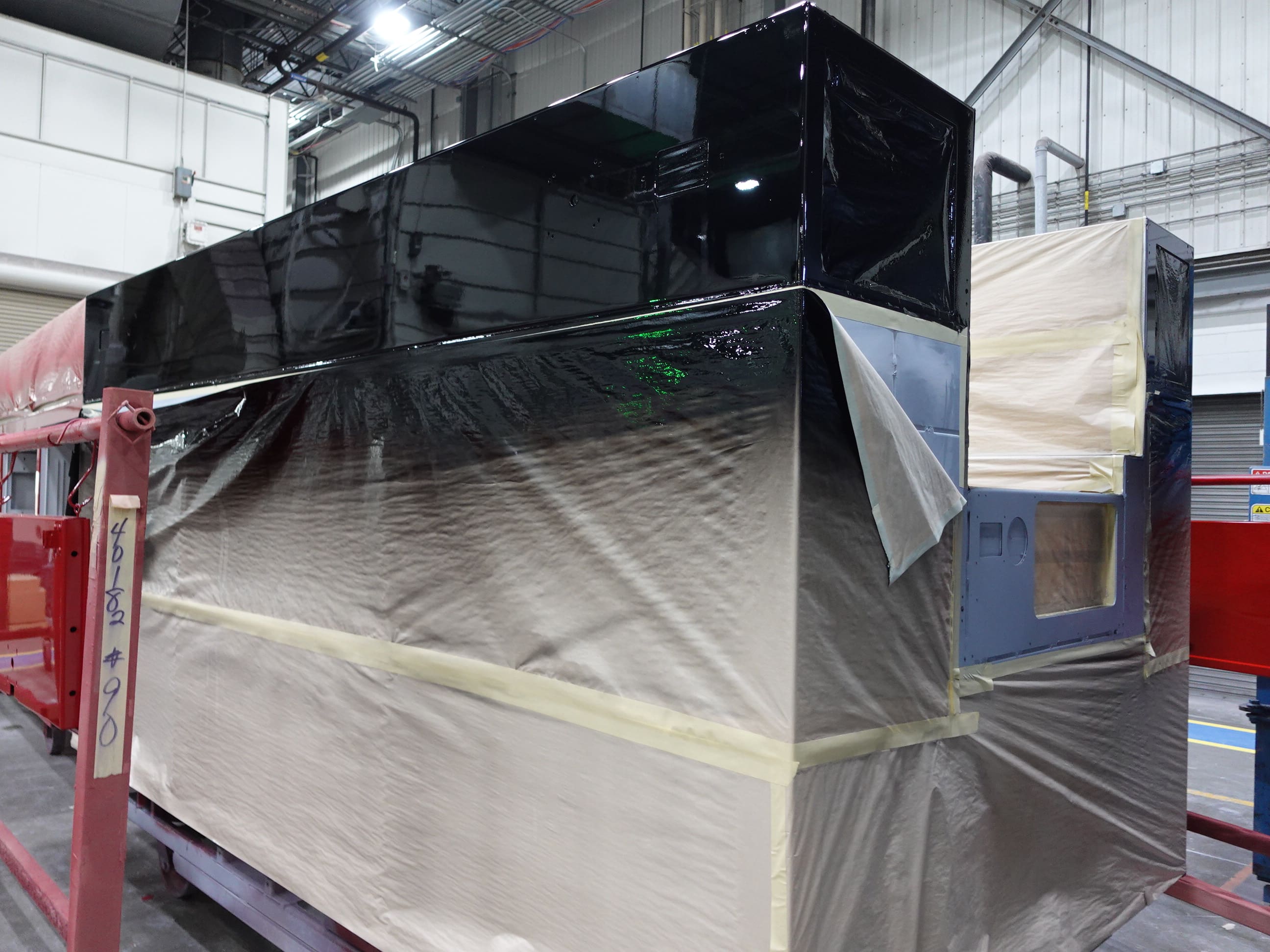

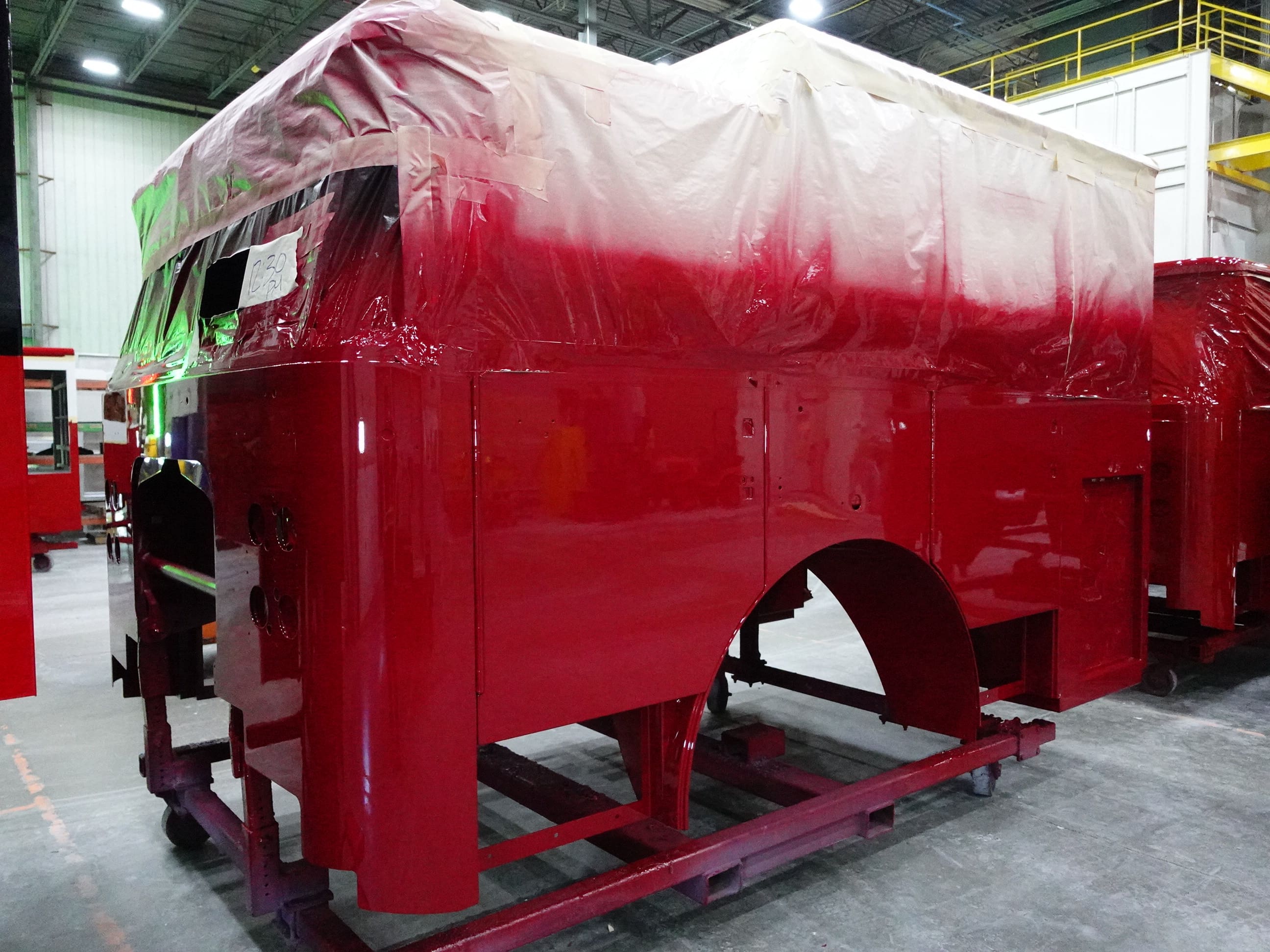

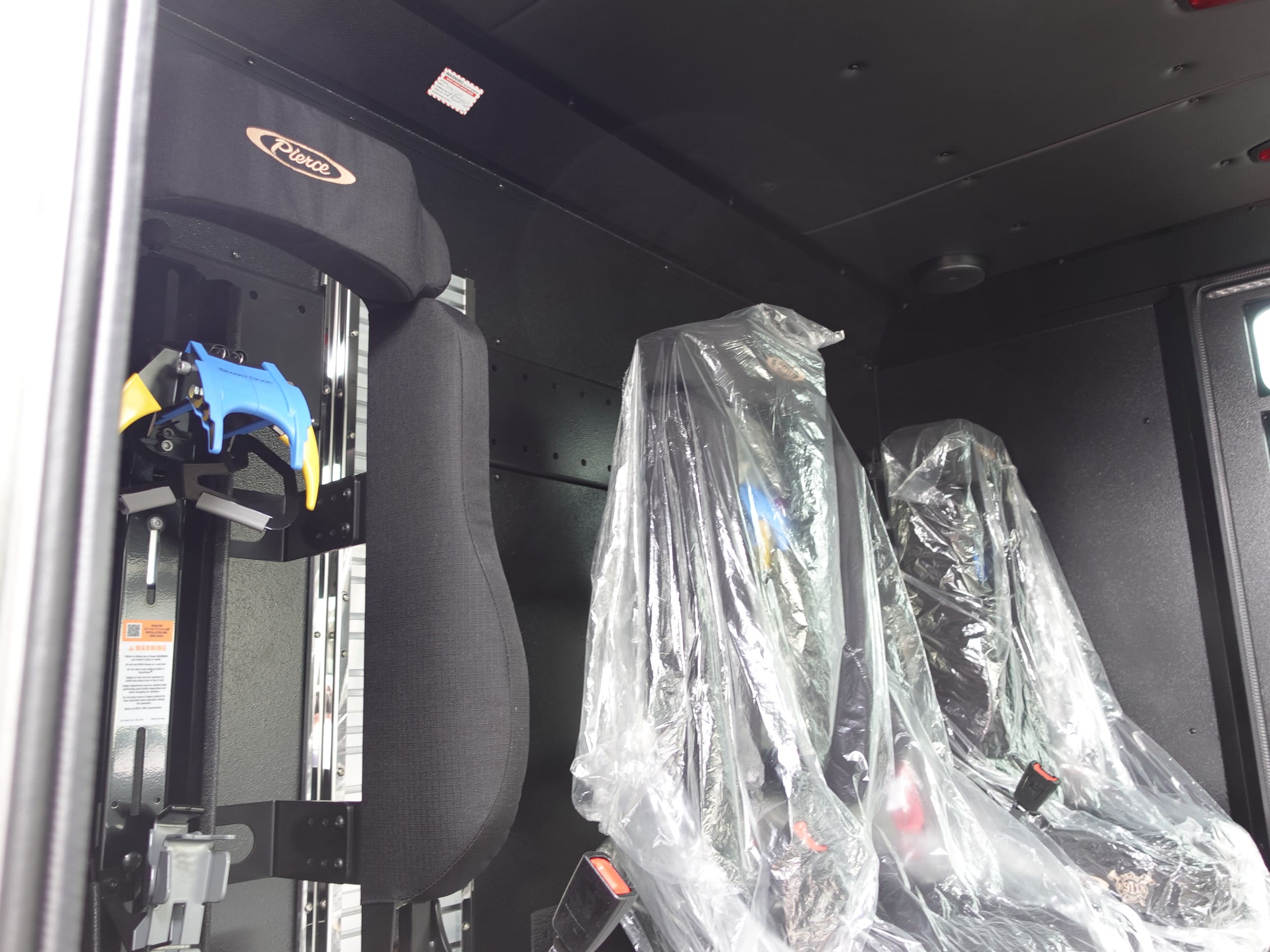

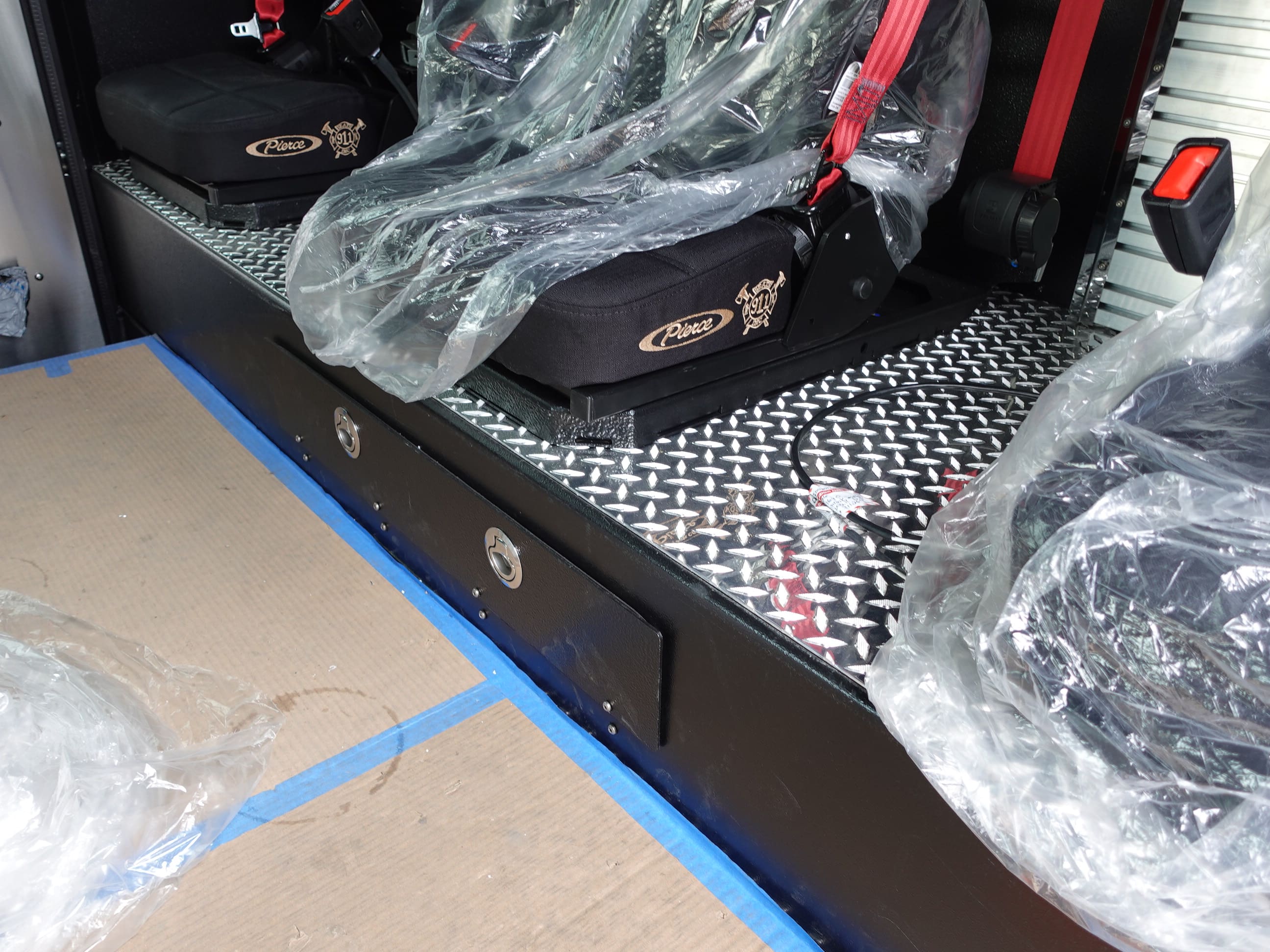

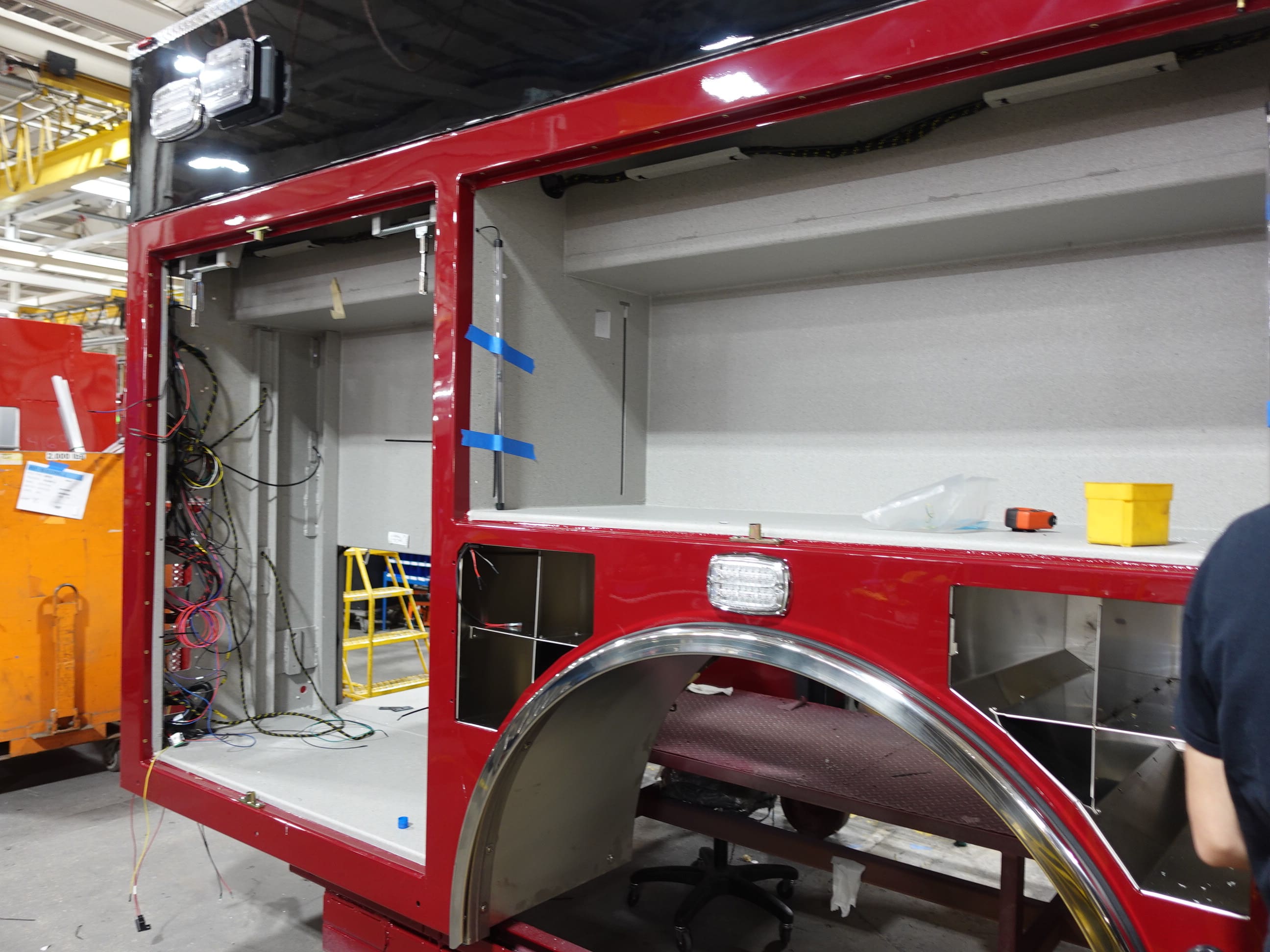

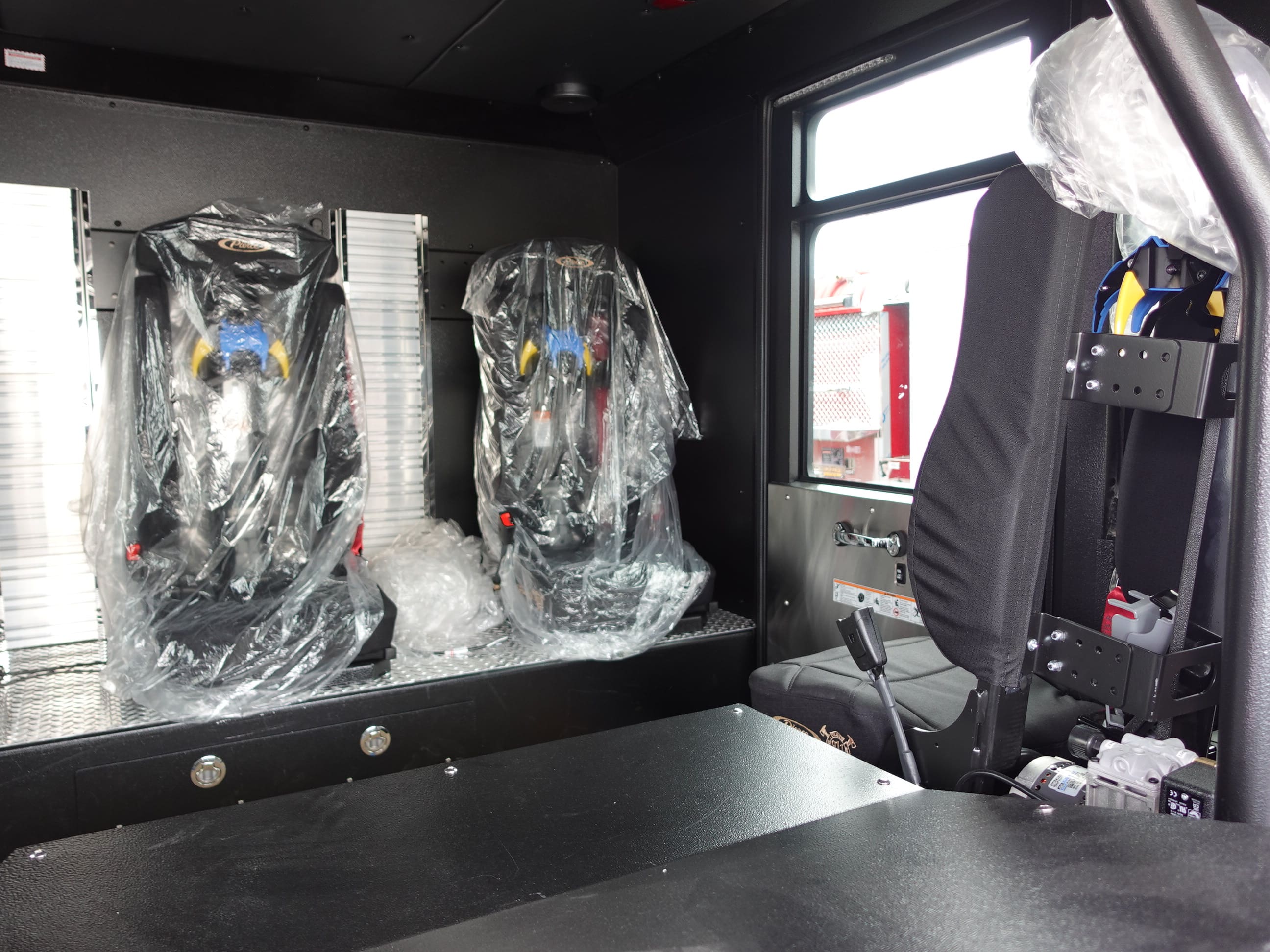

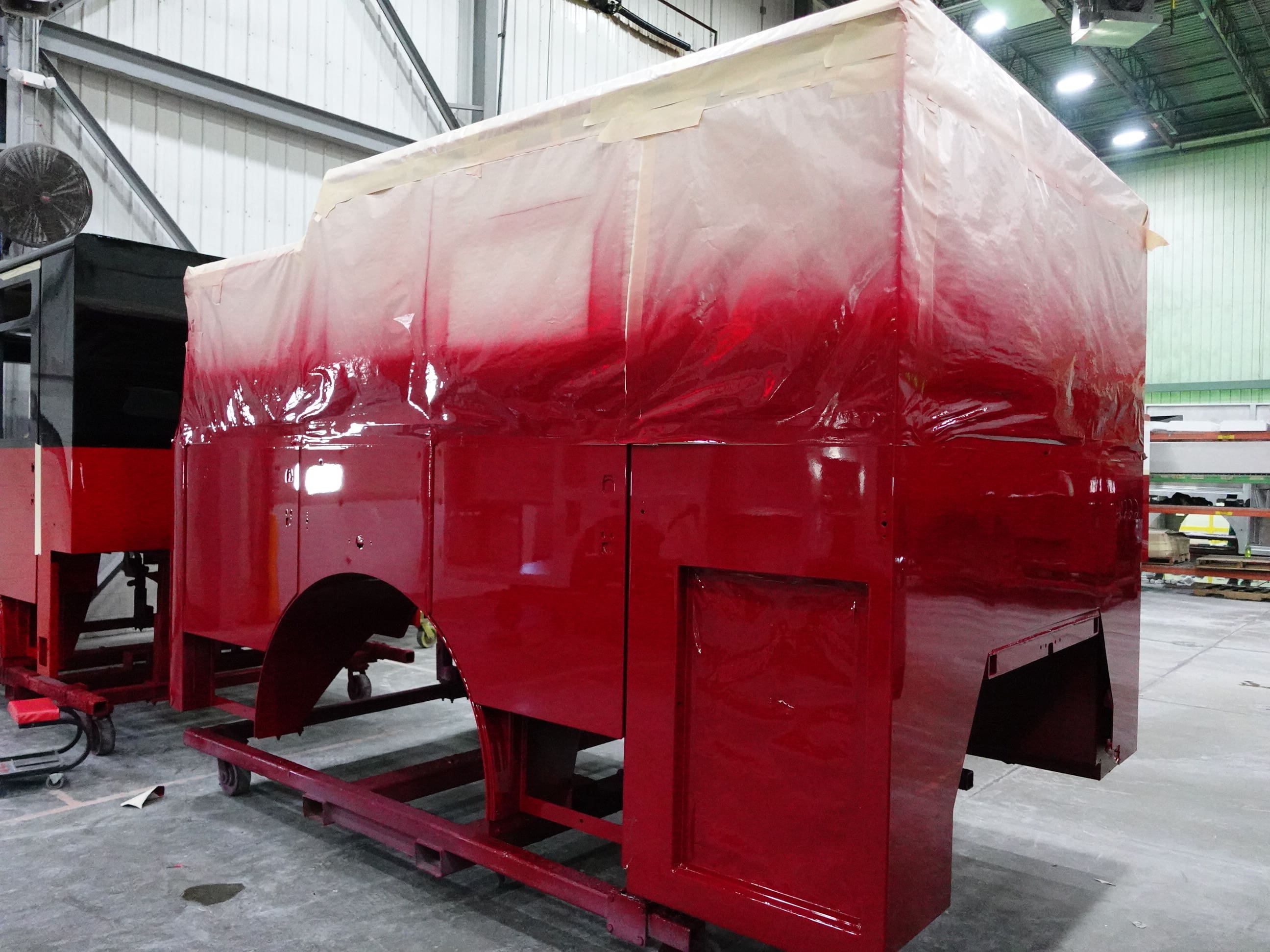

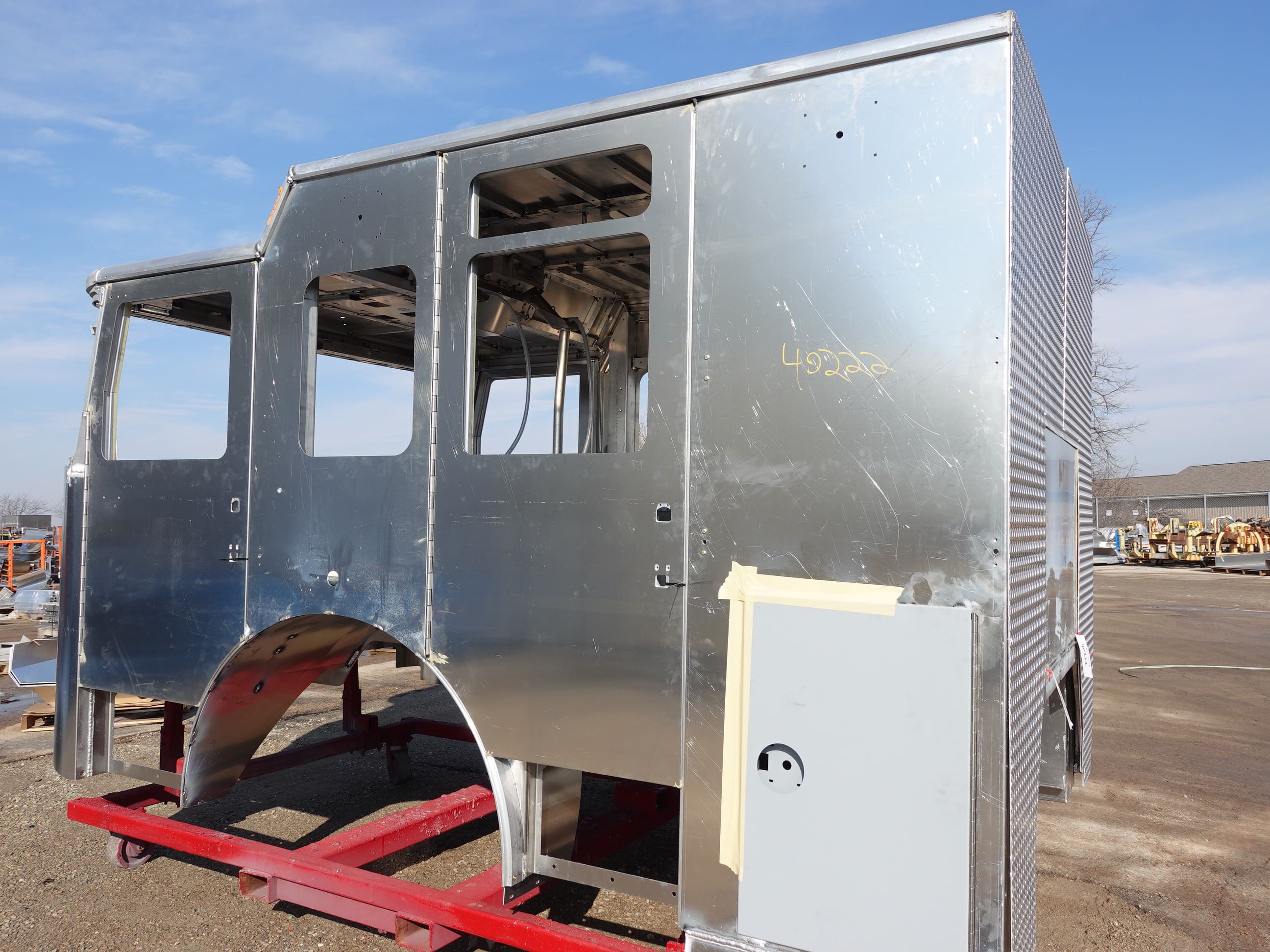

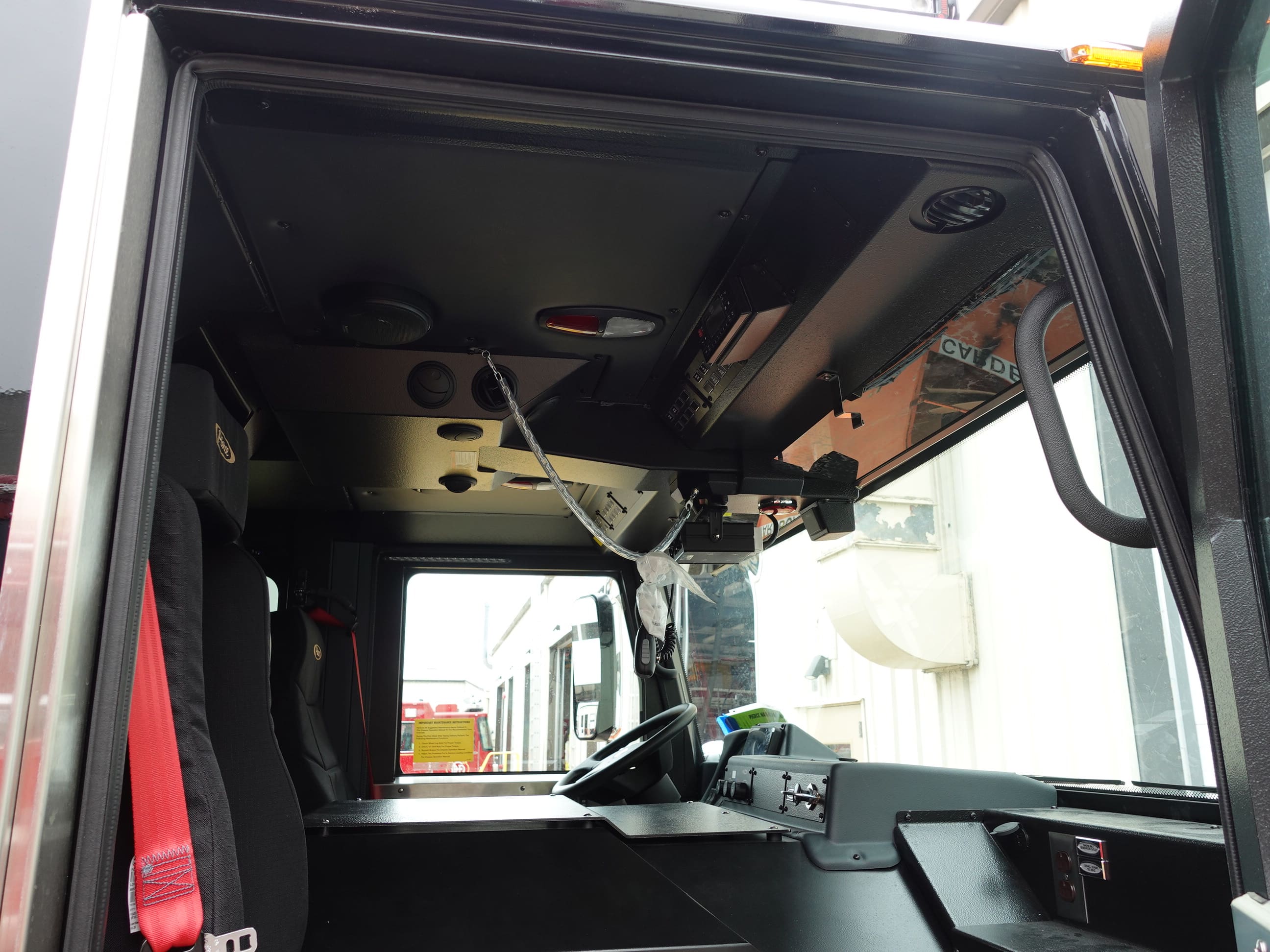

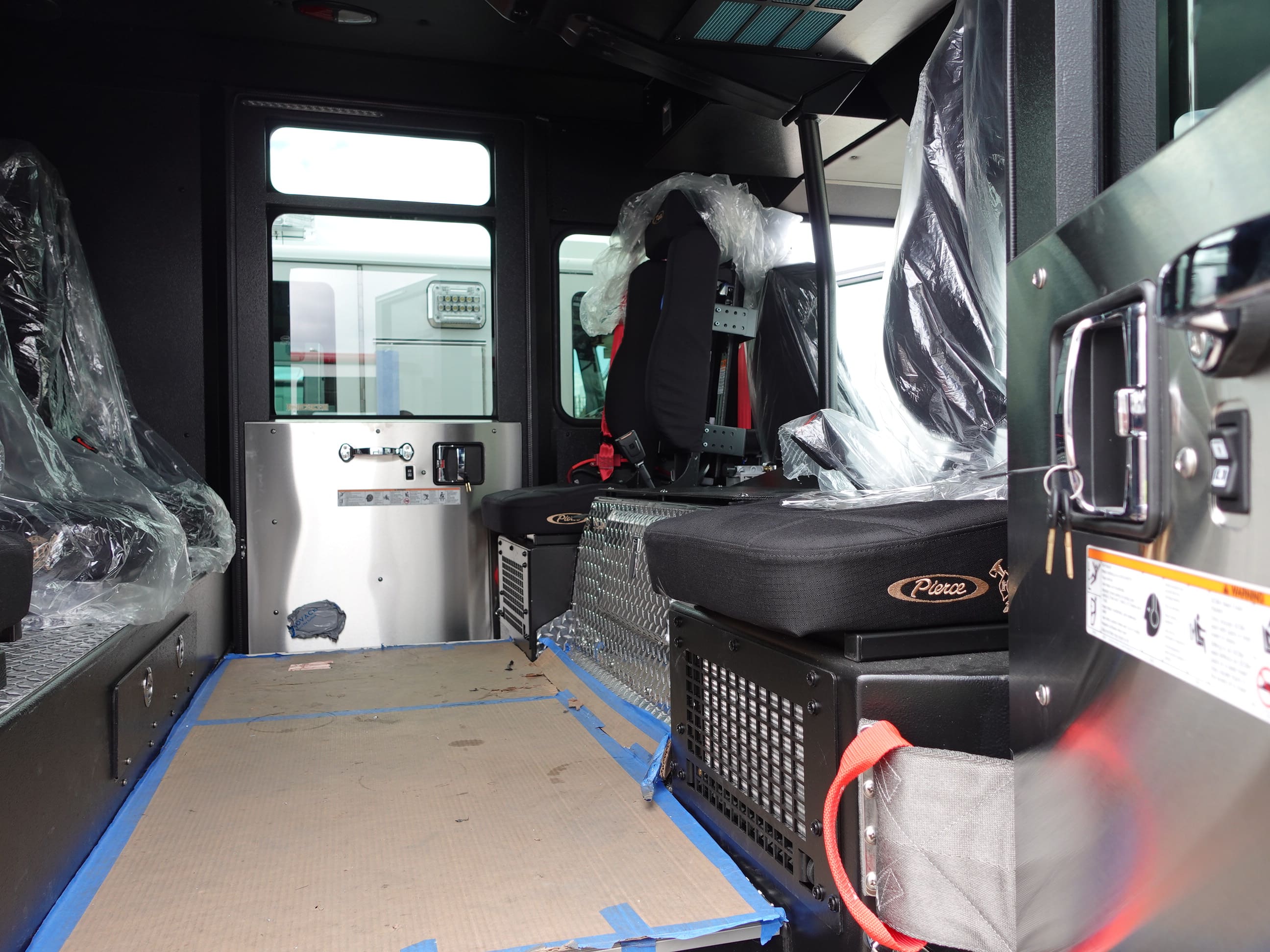

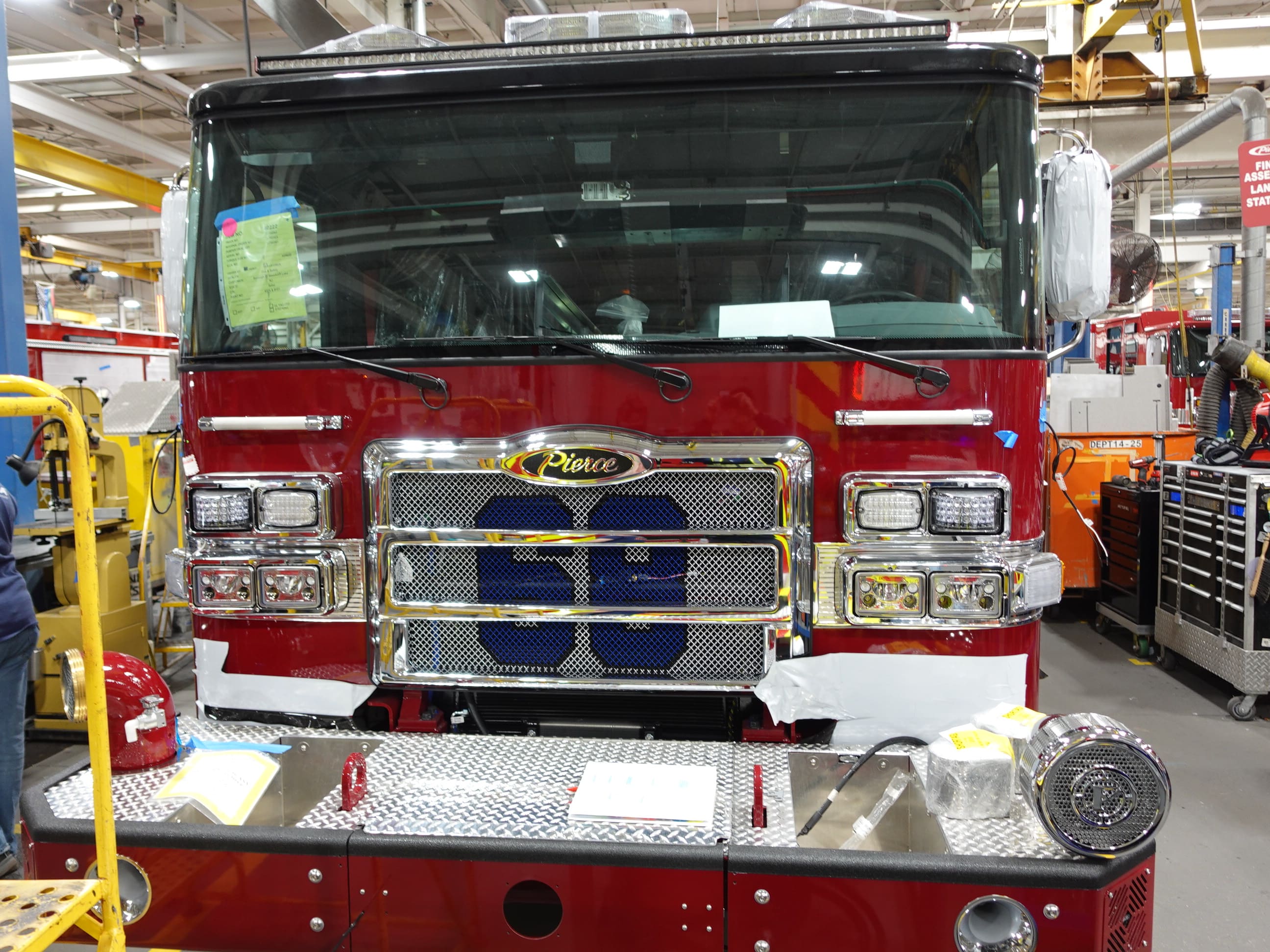

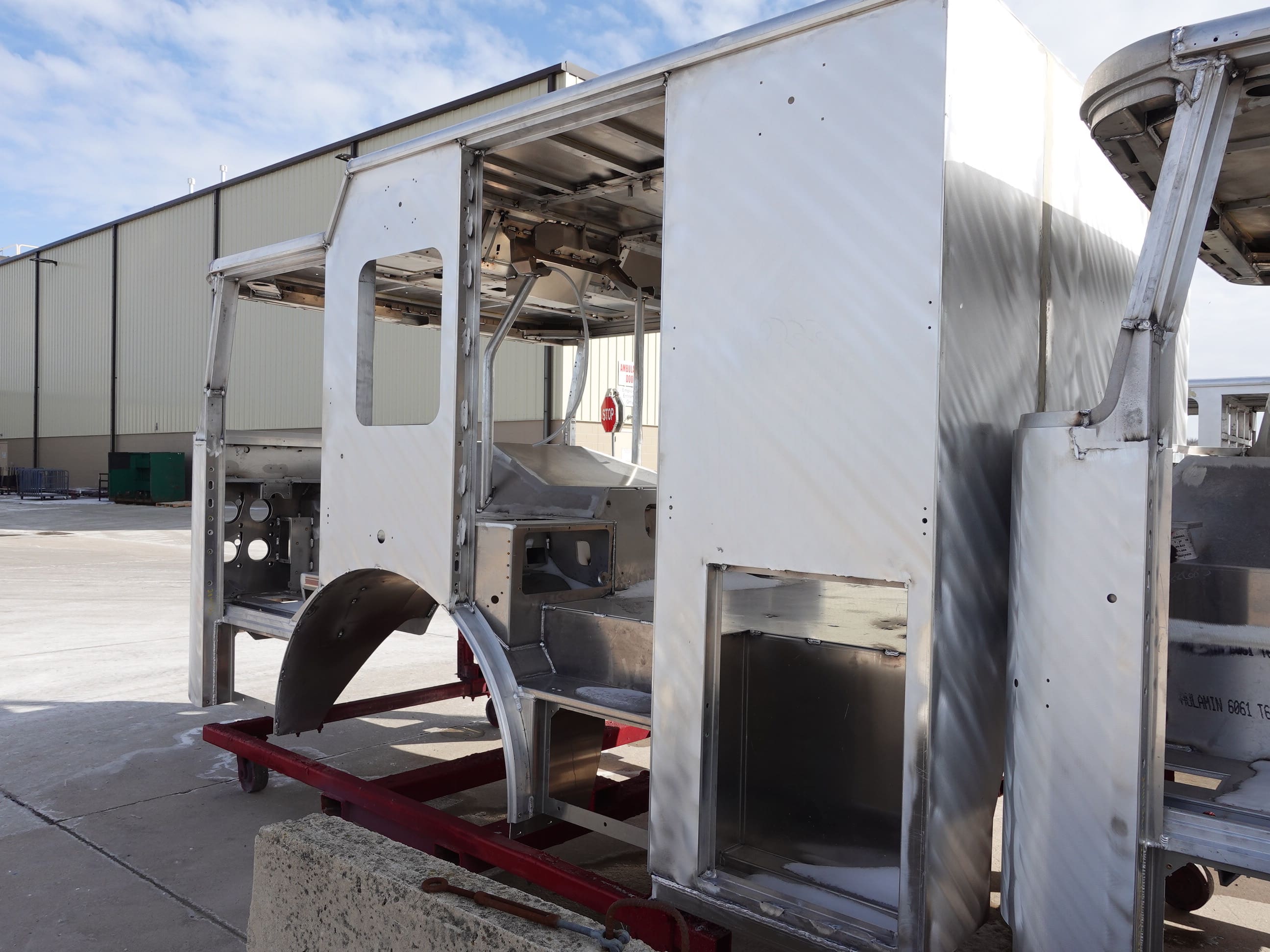

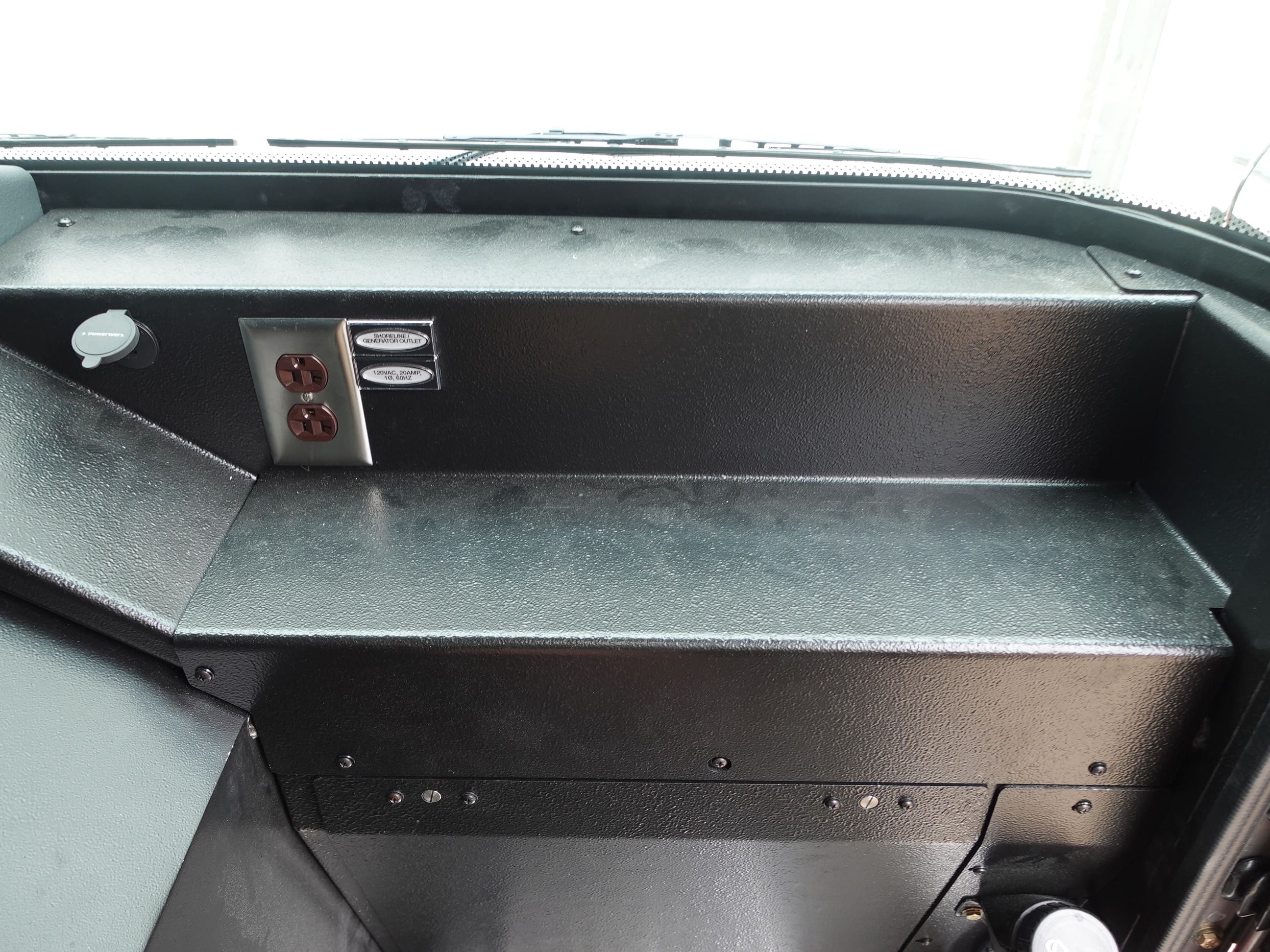

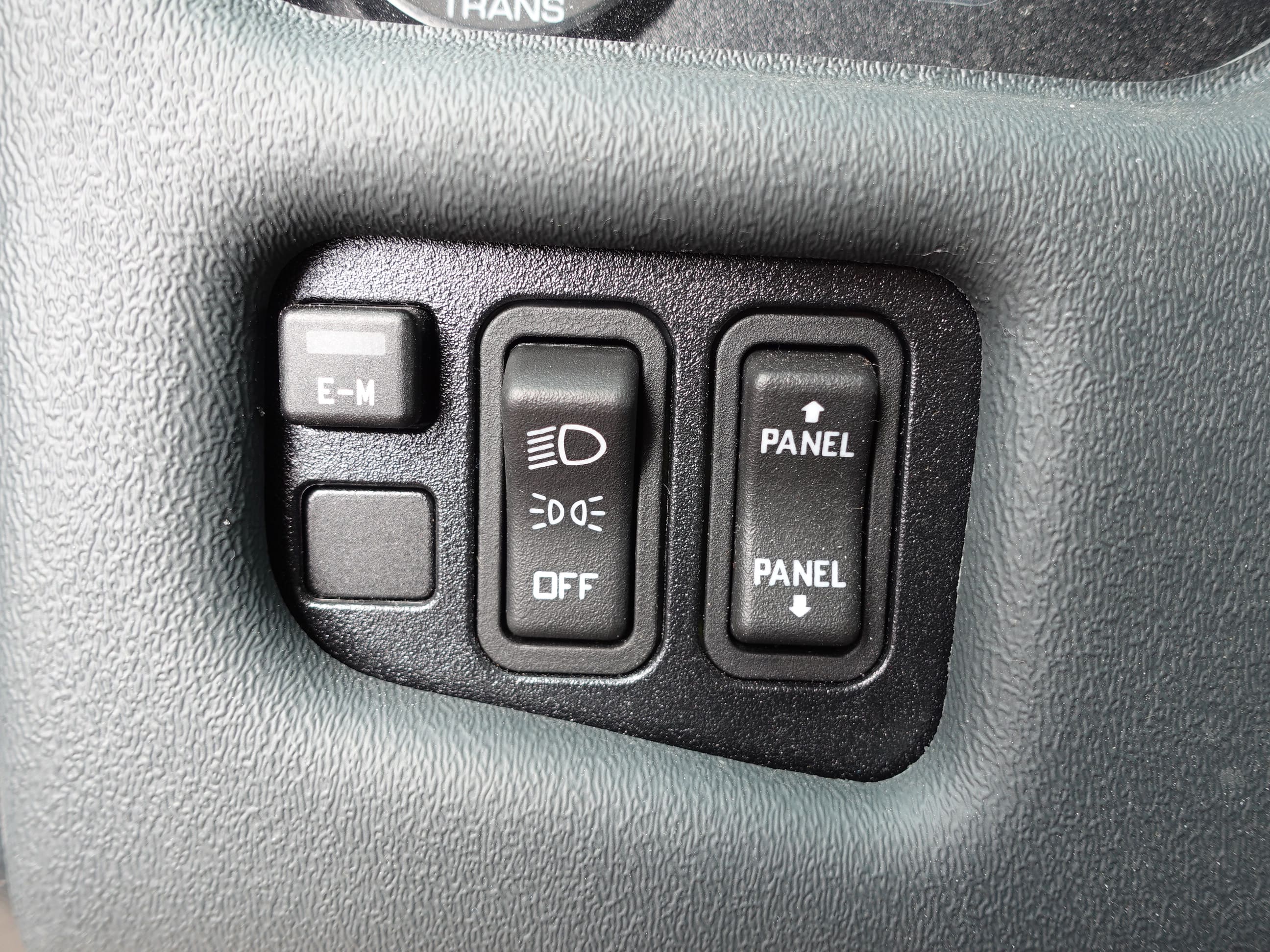

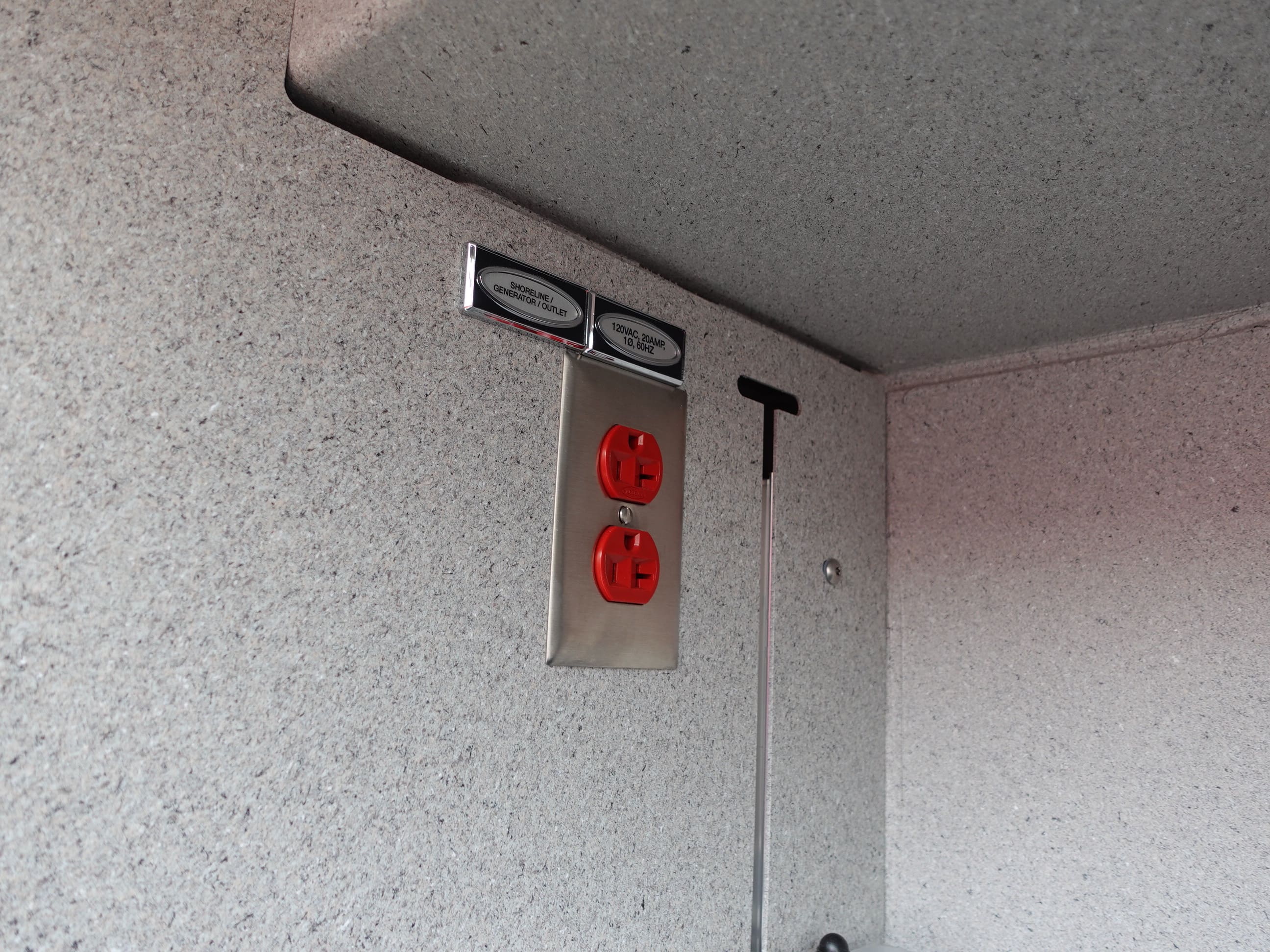

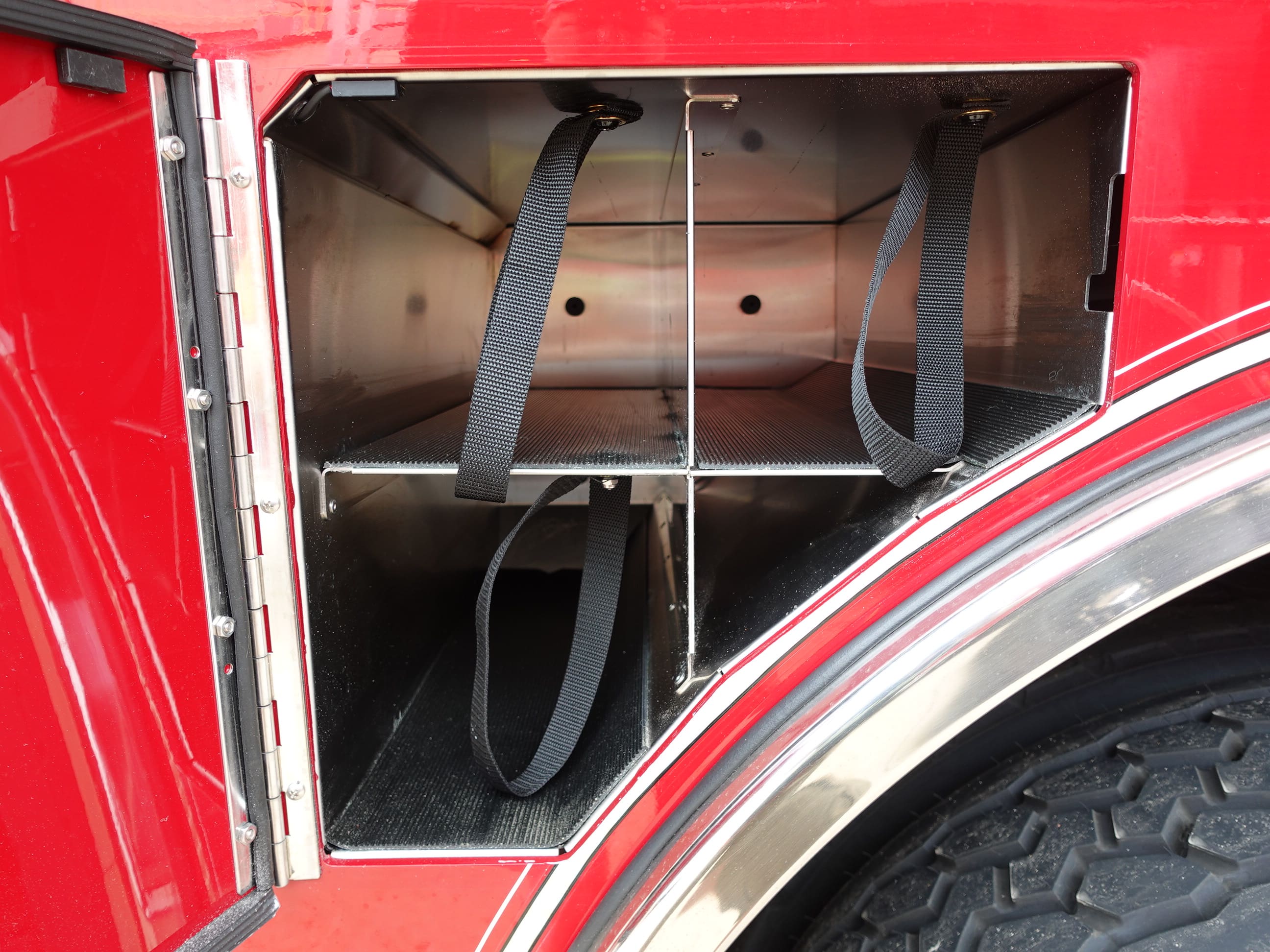

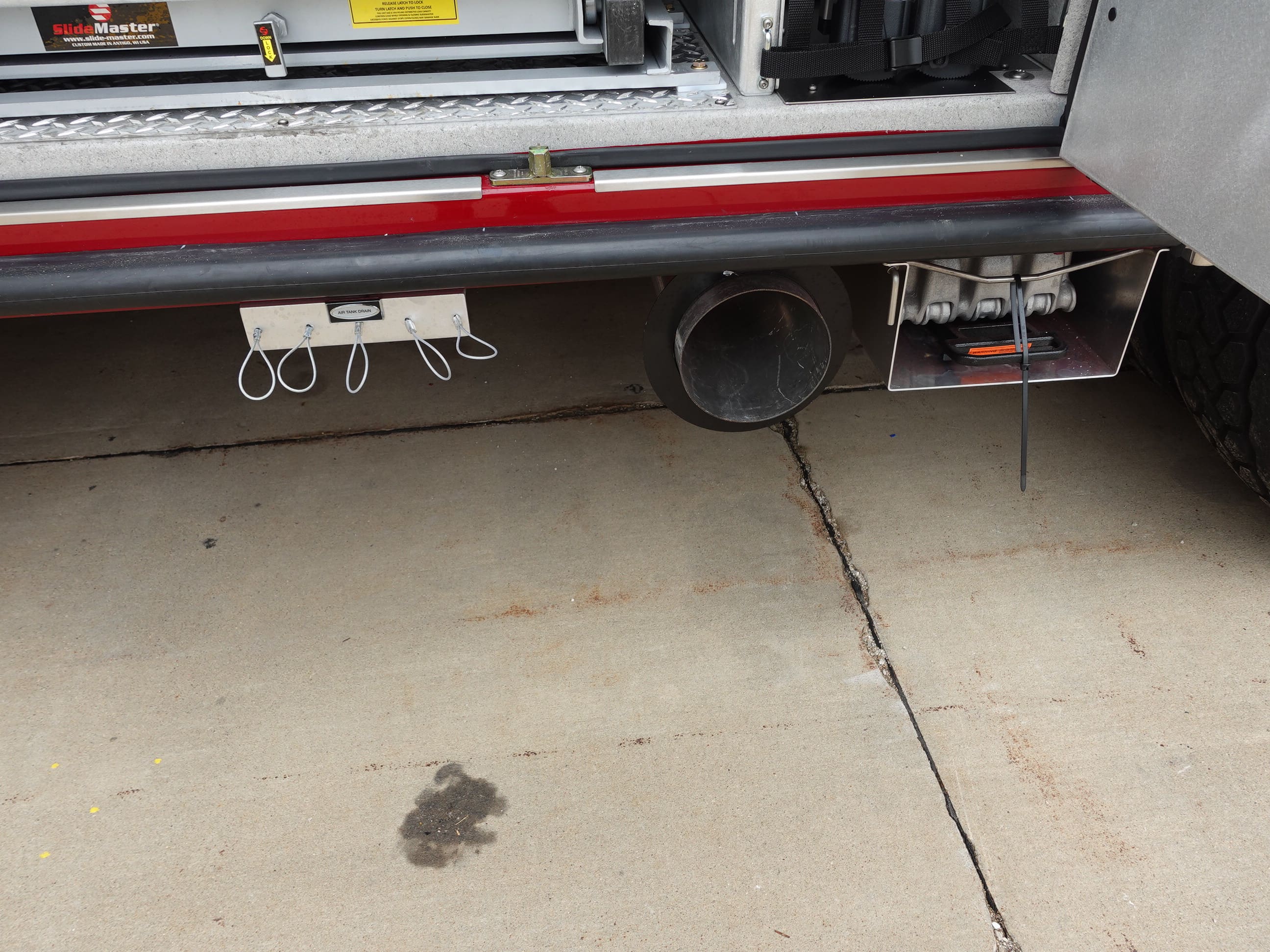

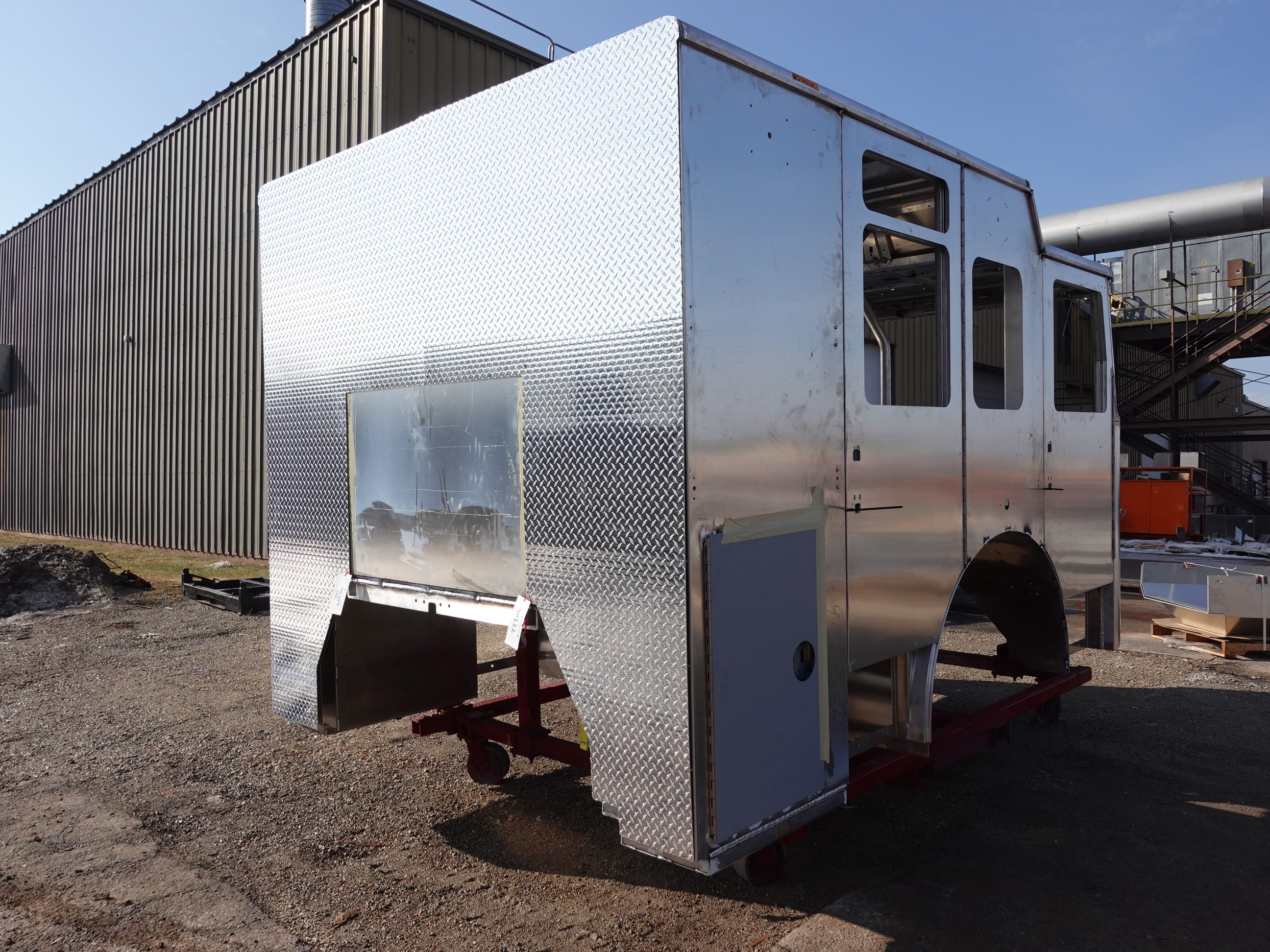

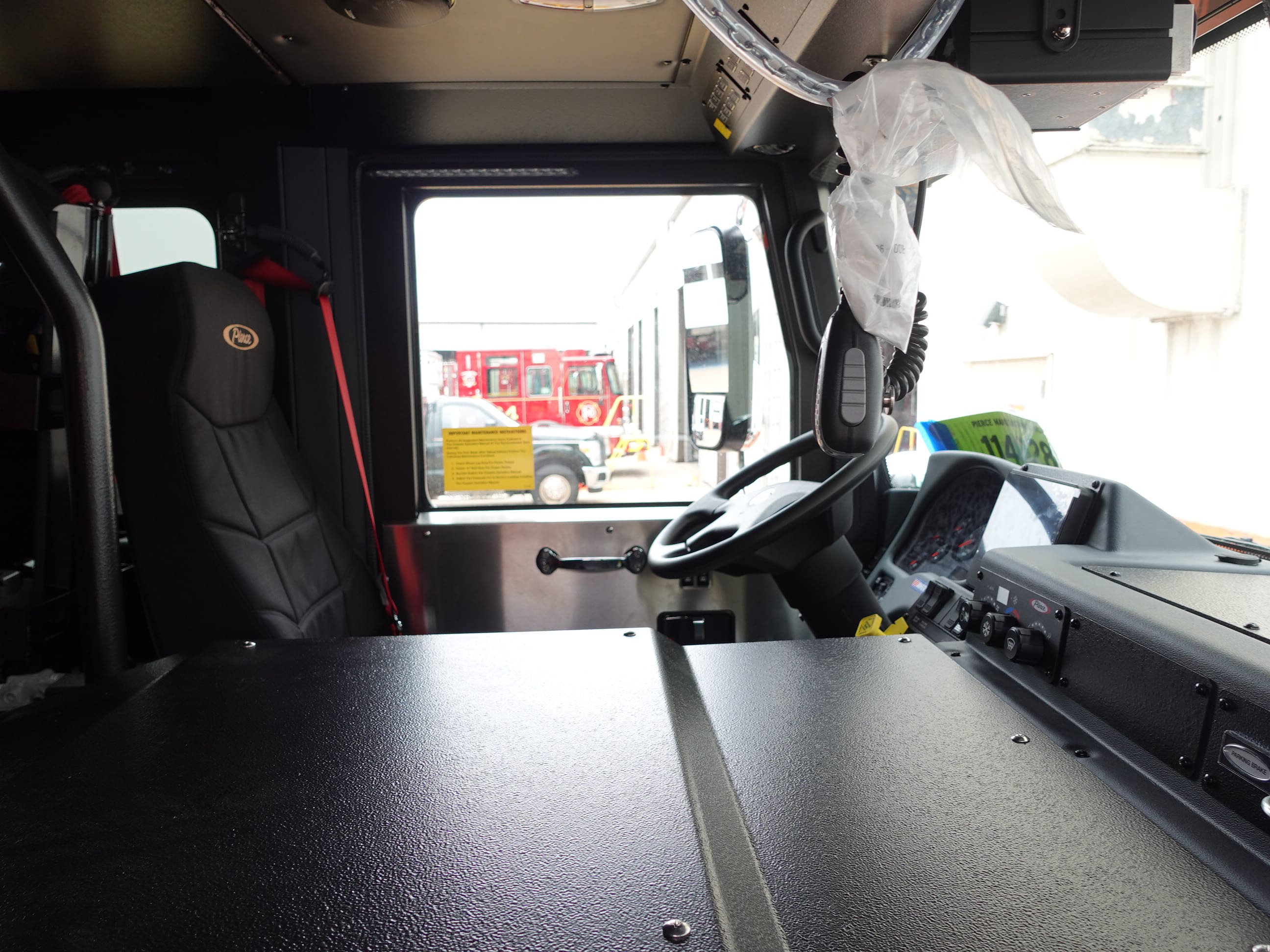

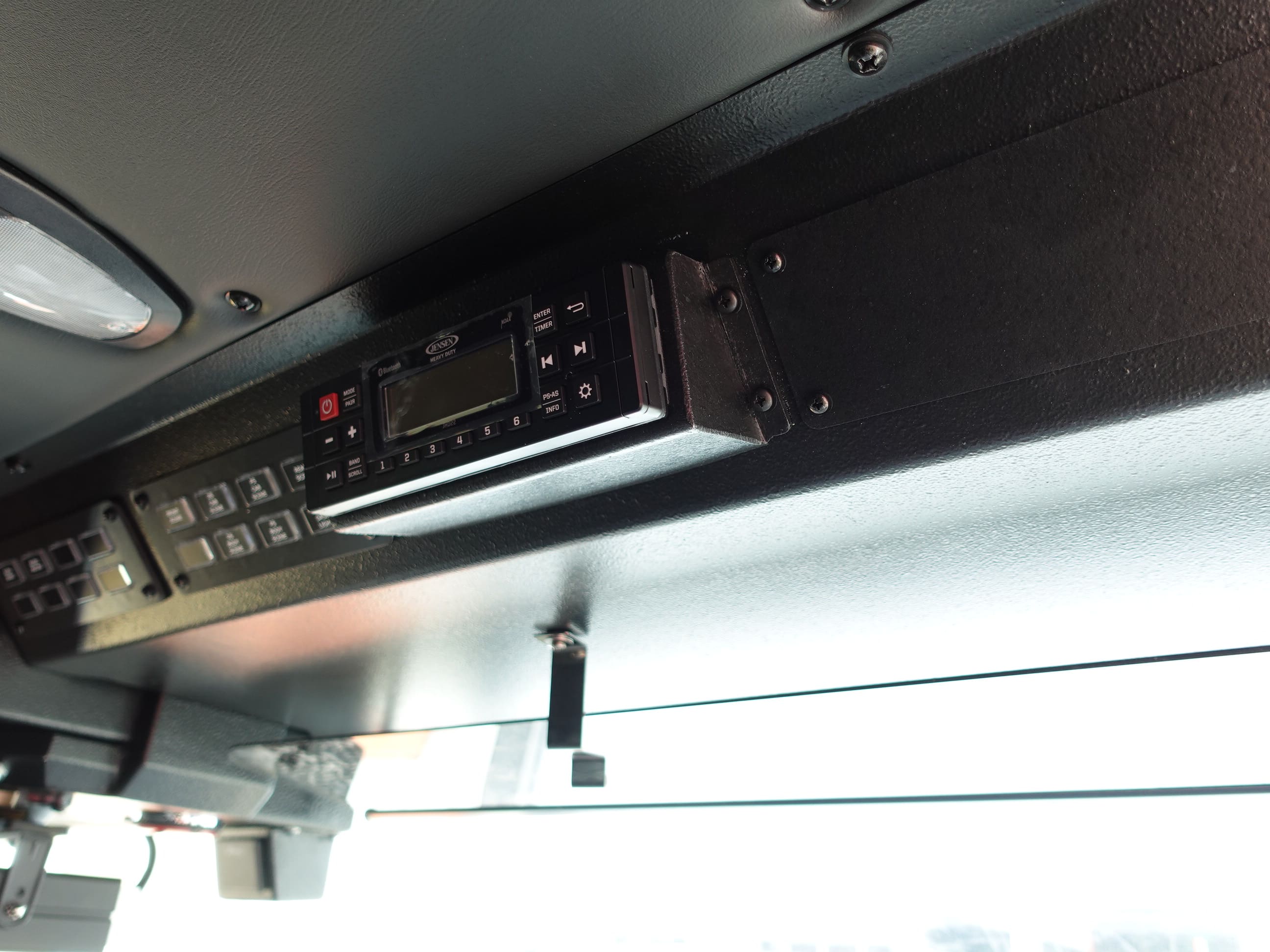

In this report, the cab completed initial assembly, the frame build continued, the pump house completed initial assembly, and the body completed paint and began initial assembly.
04-03-26

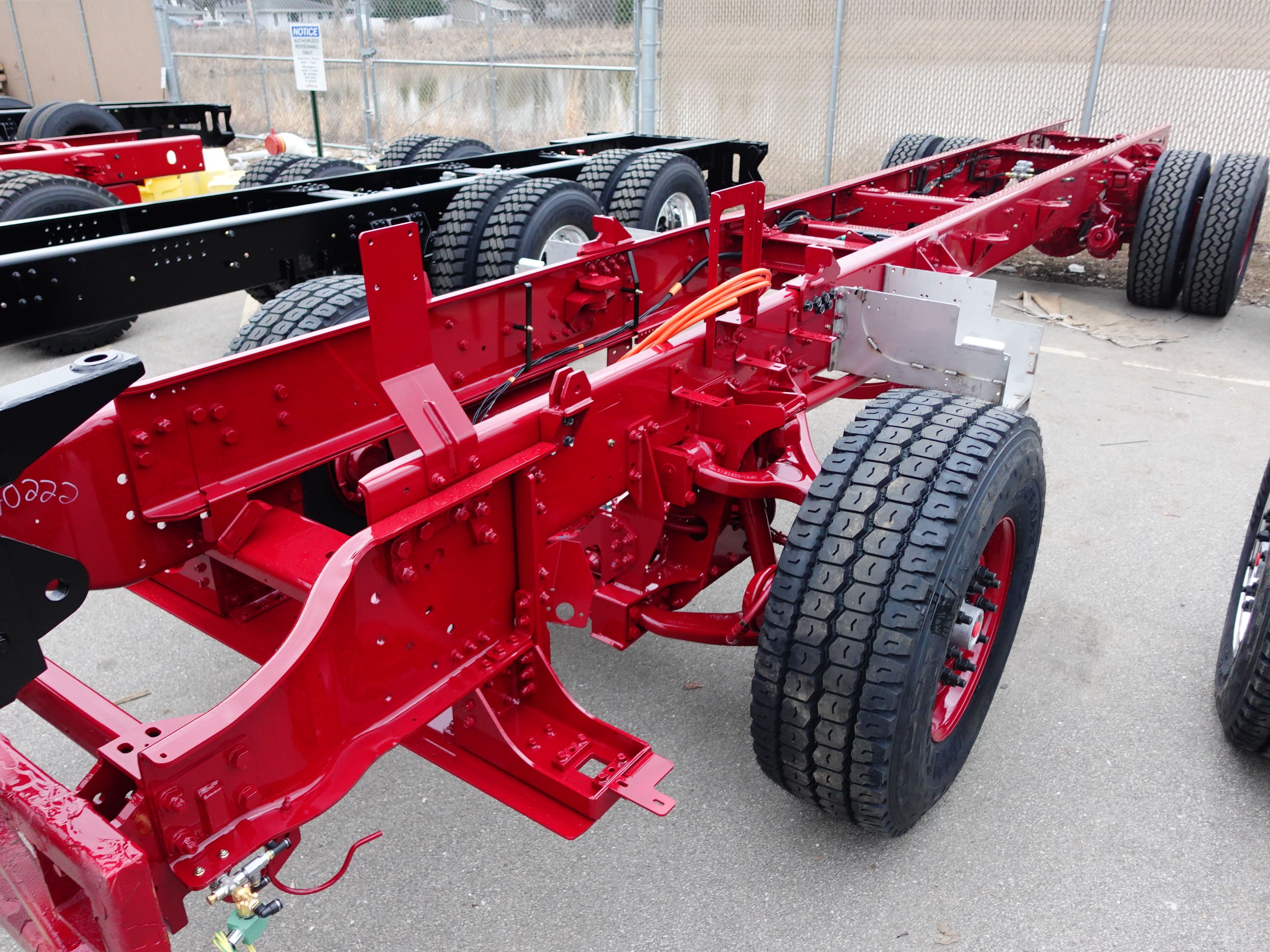

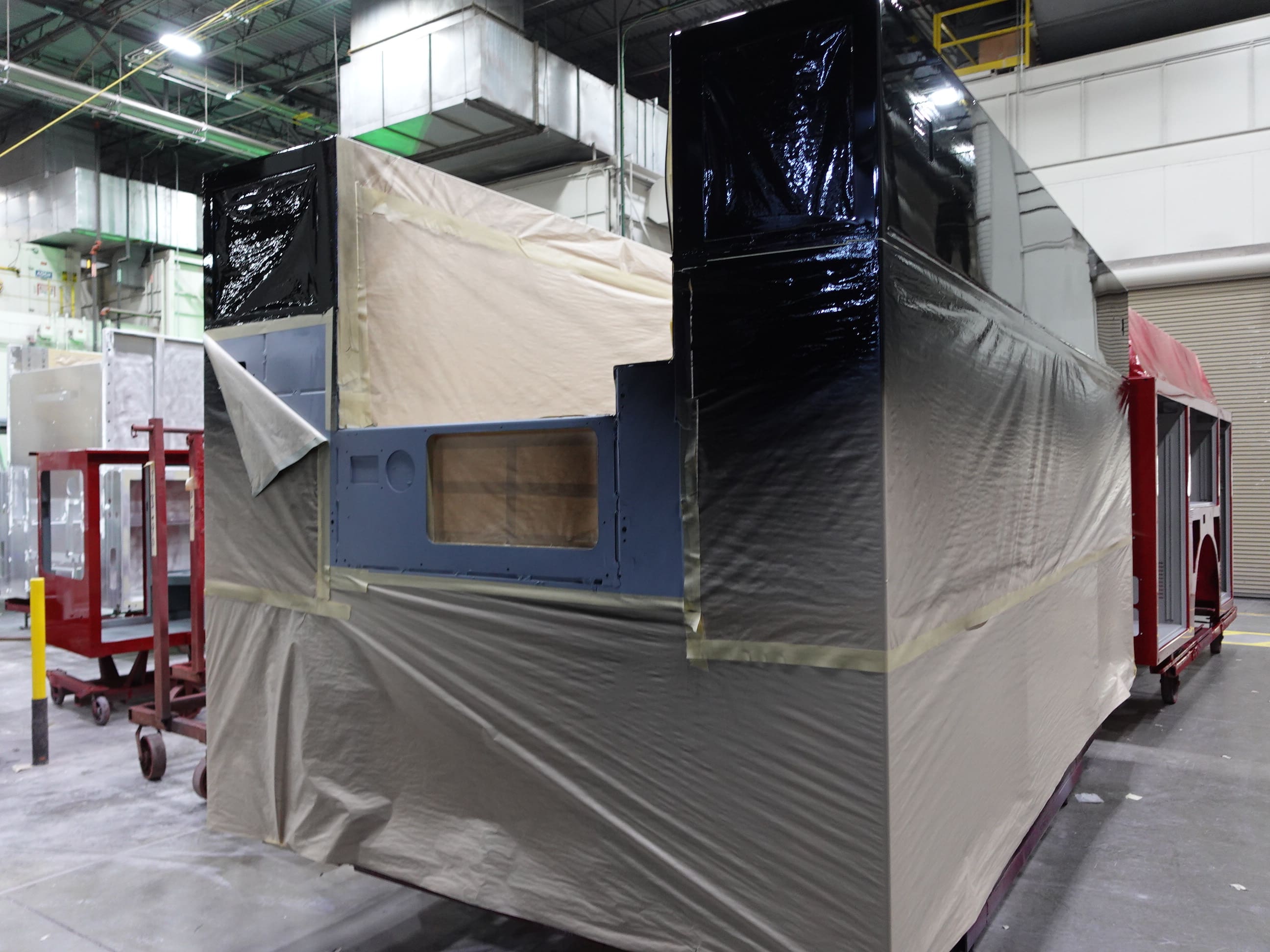

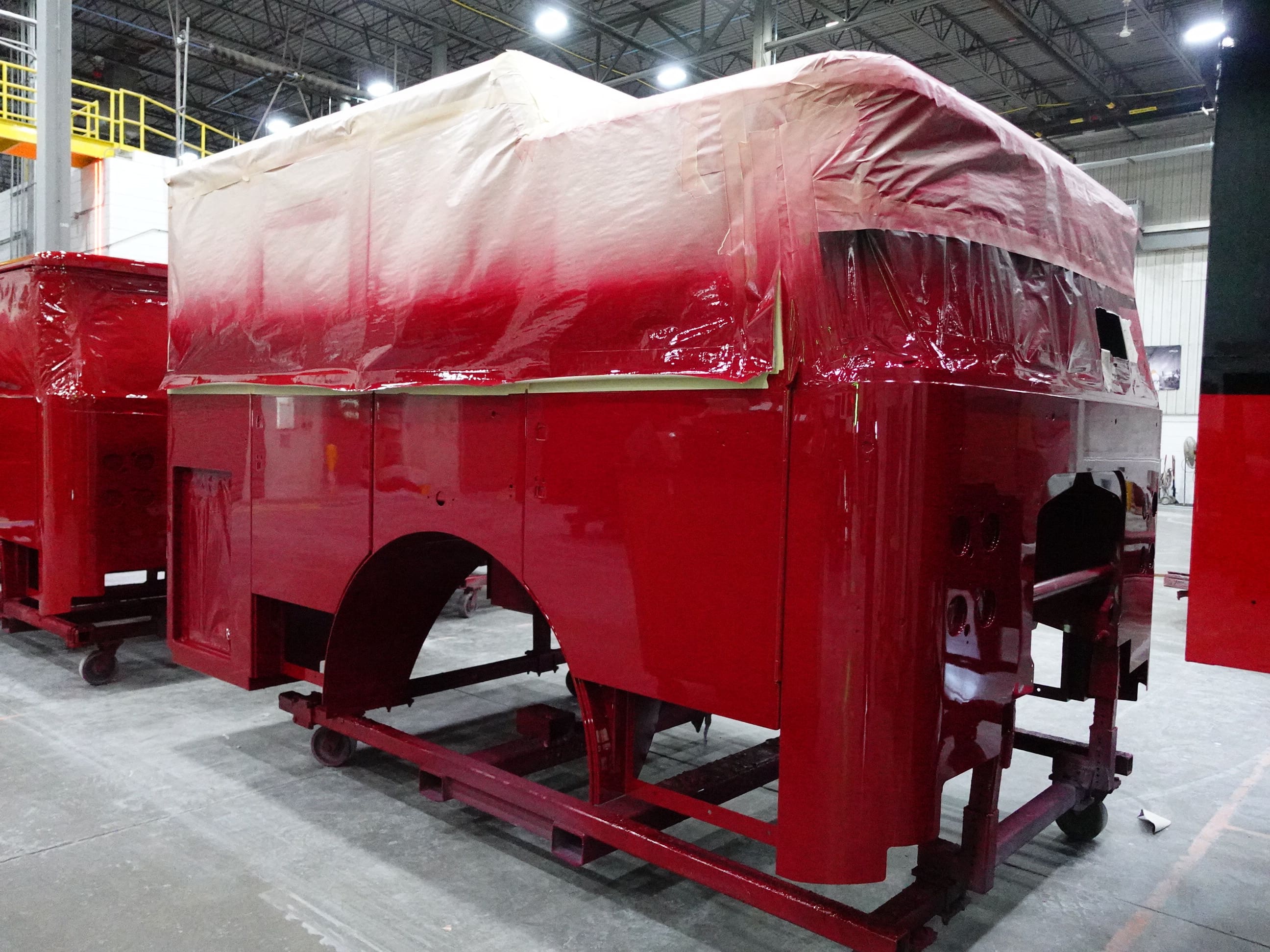

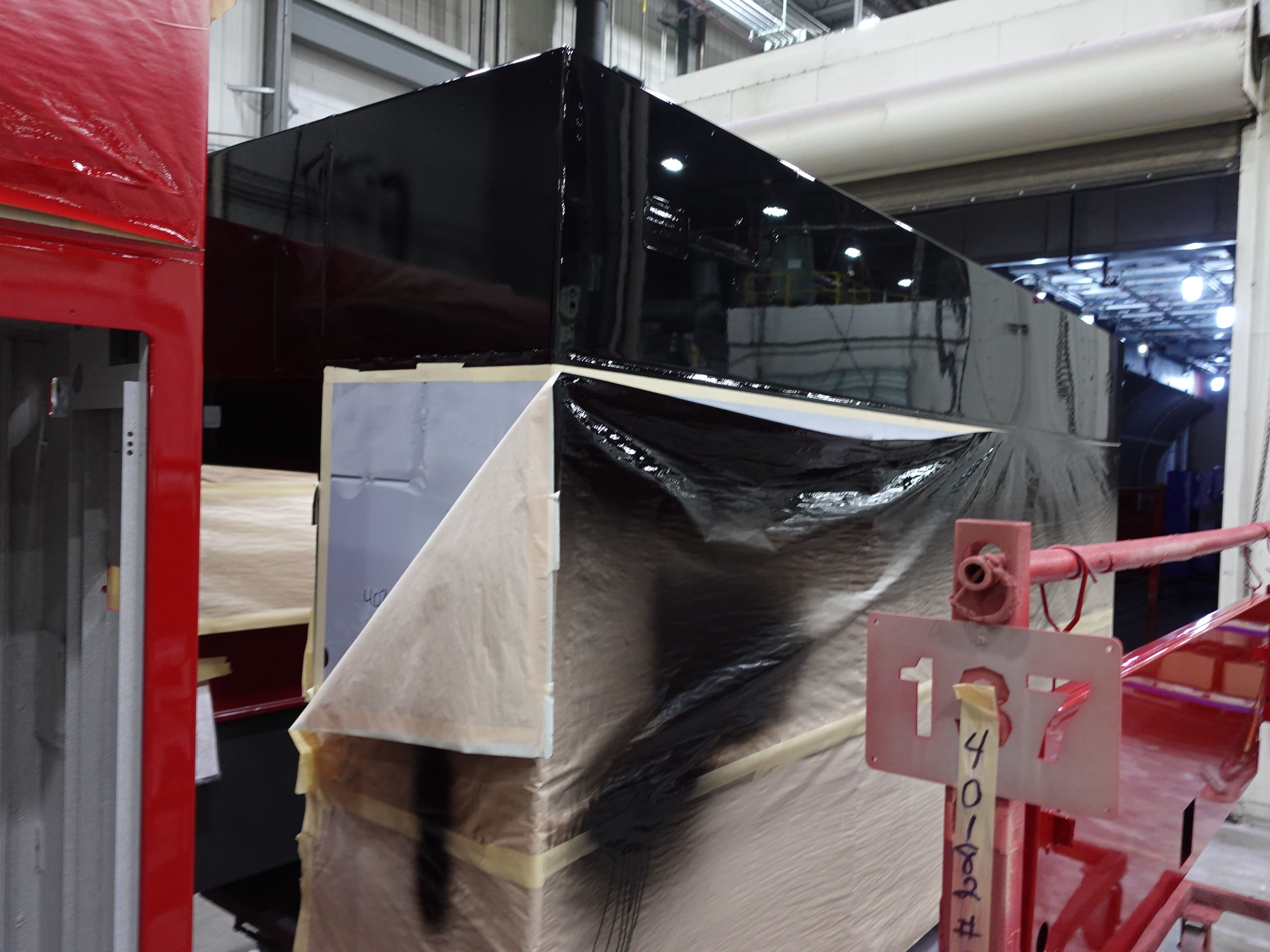

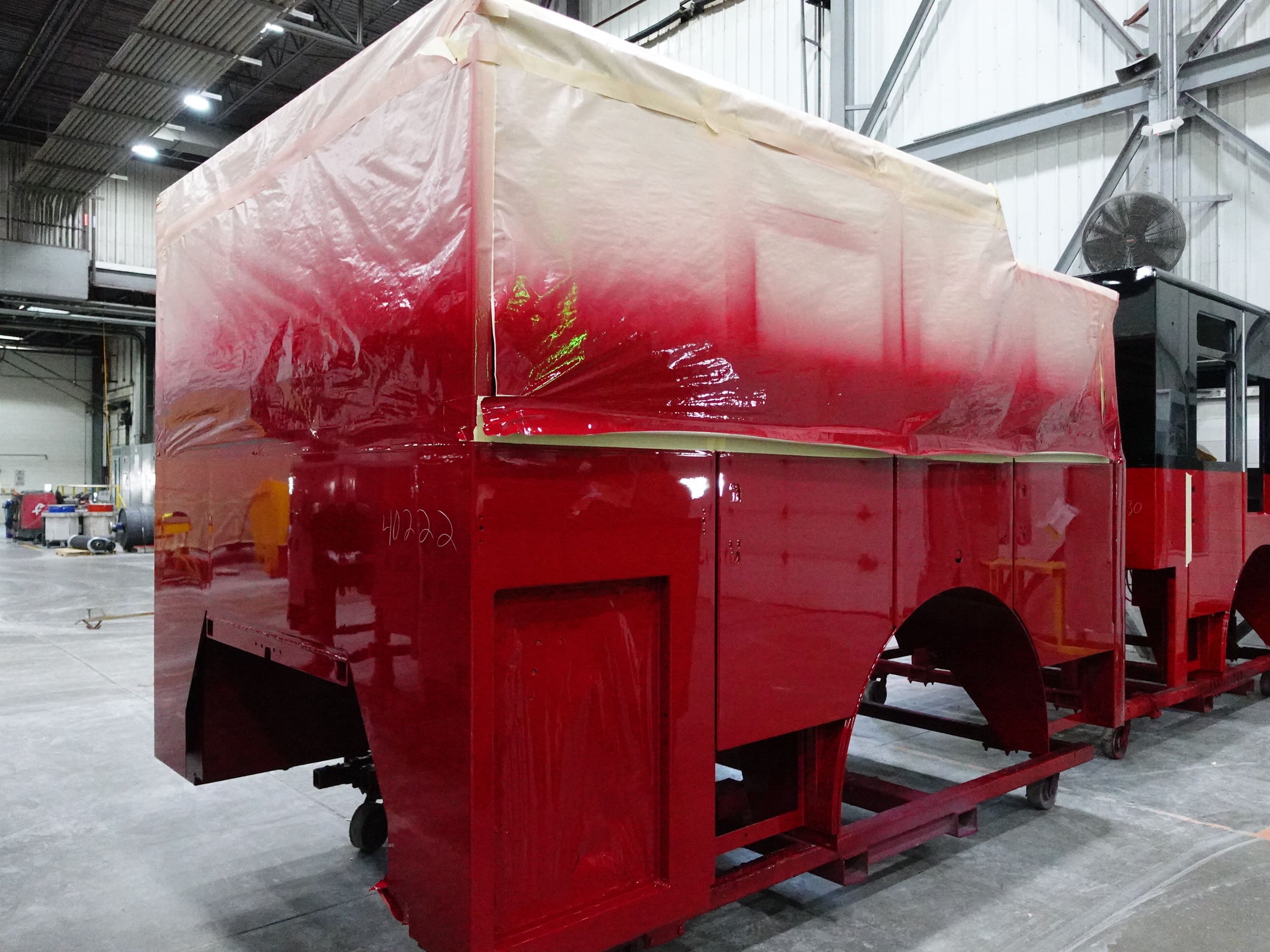

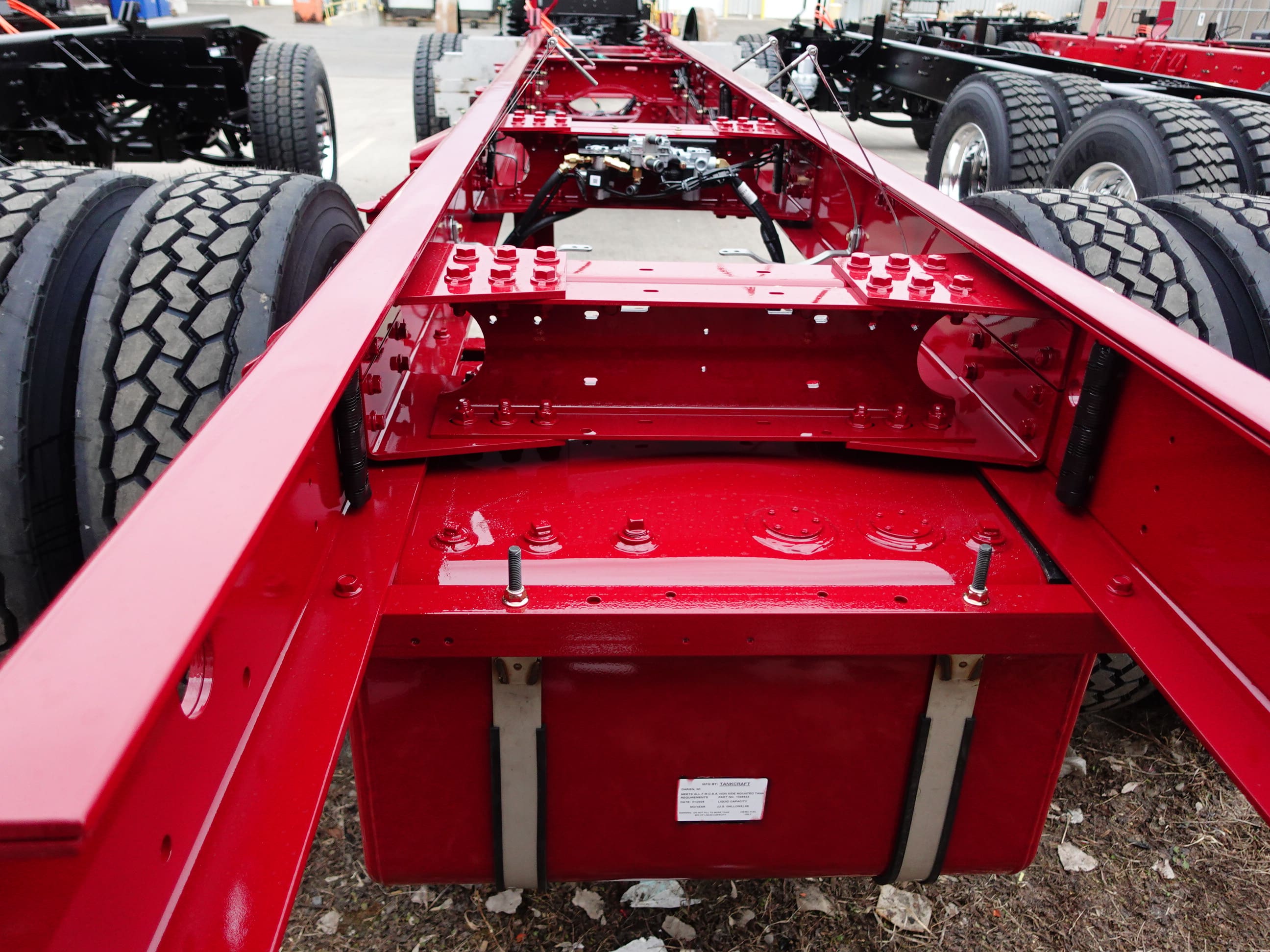

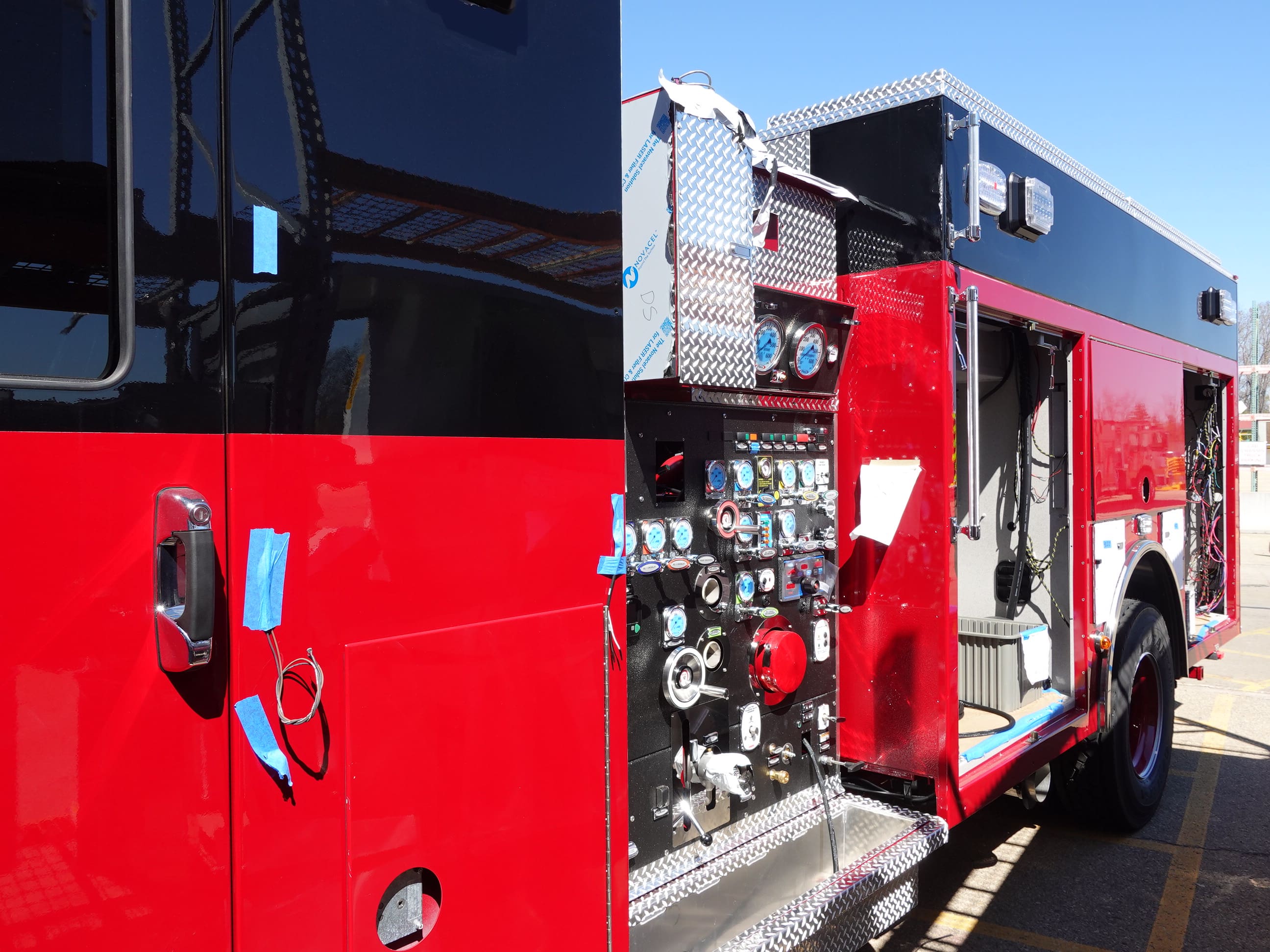

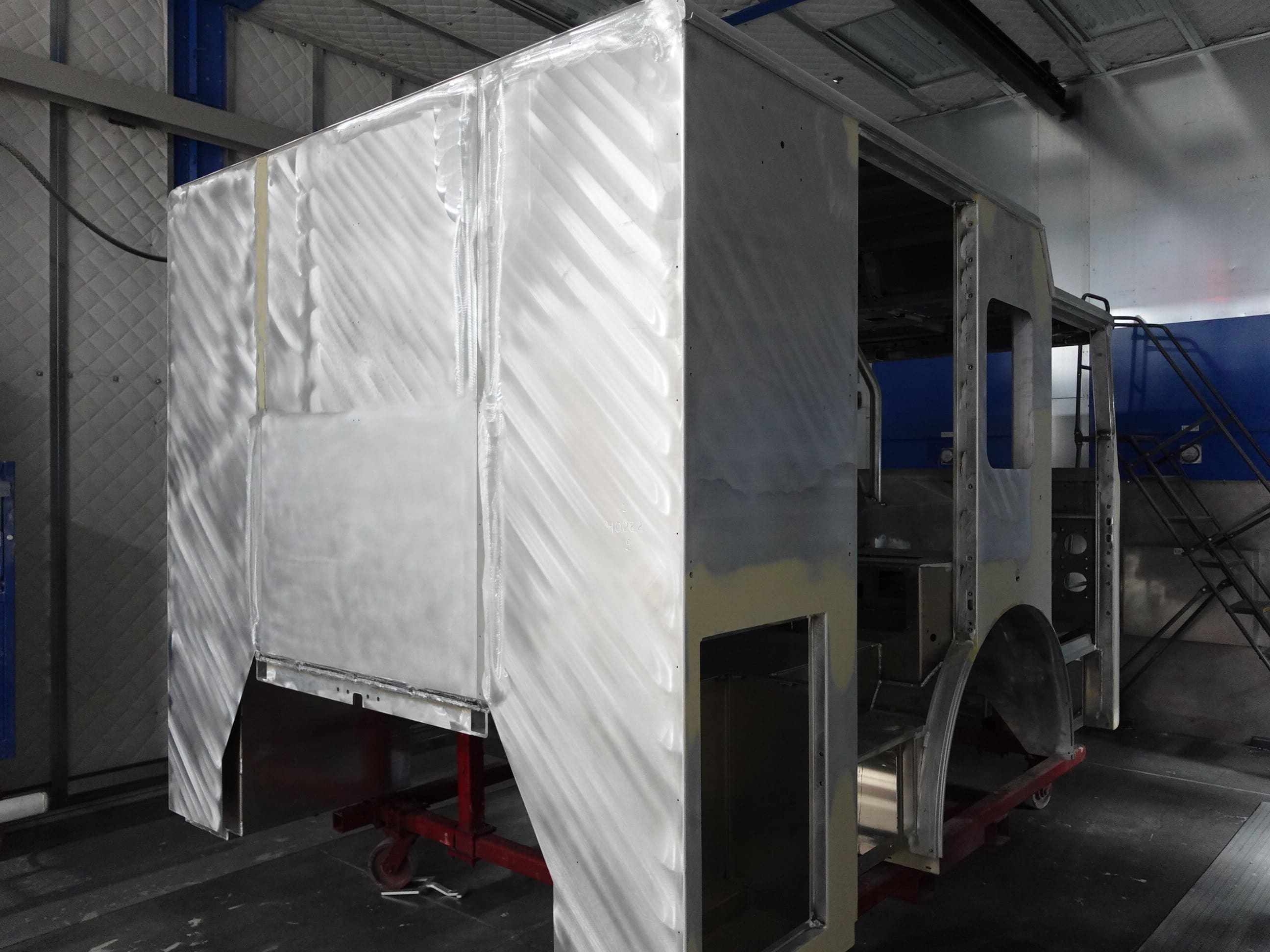

In this report, the cab completed paint and began initial assembly, the frame build began, the pump house began initial assembly, and the body began the paint process.
03-20-26

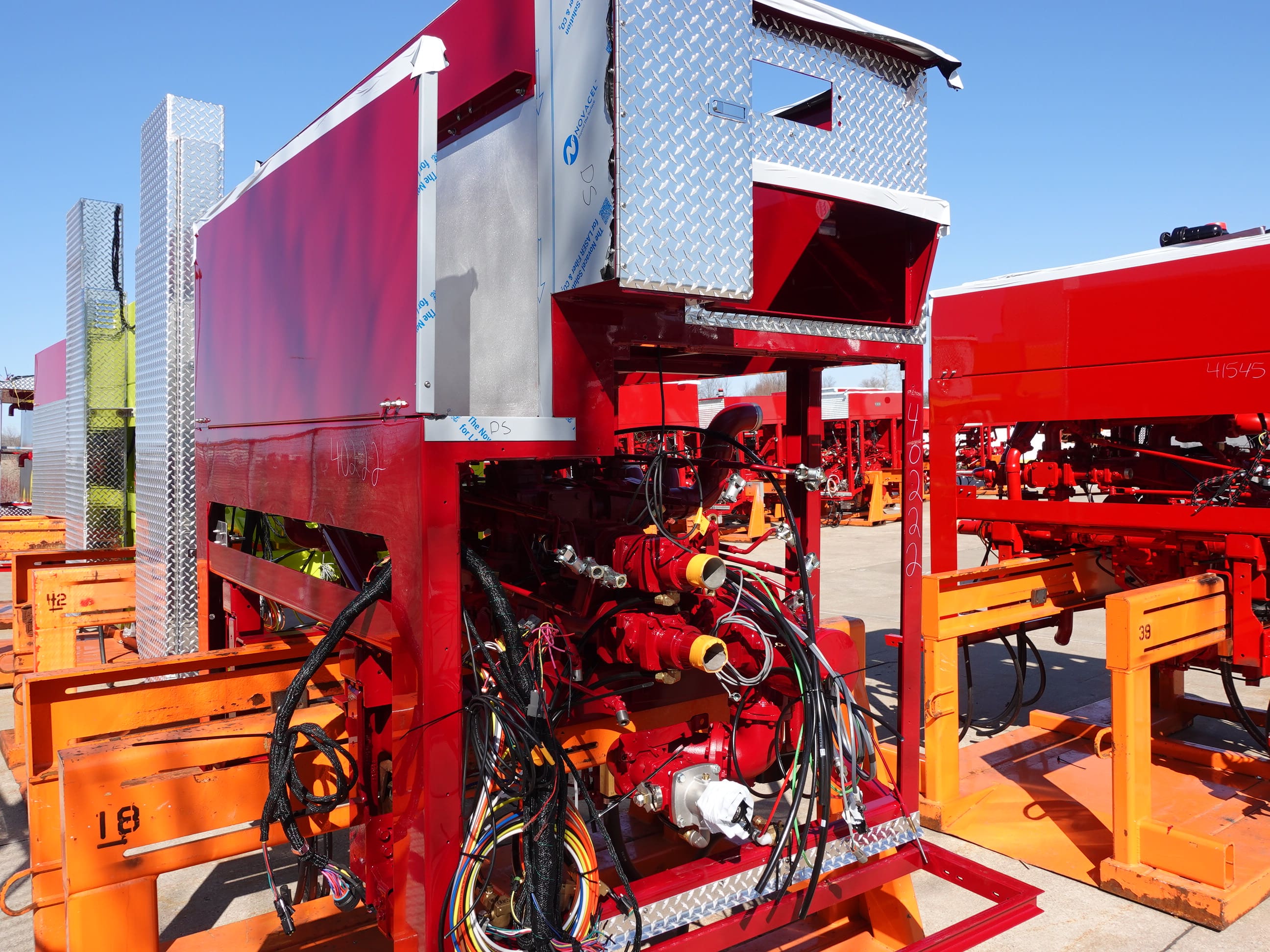

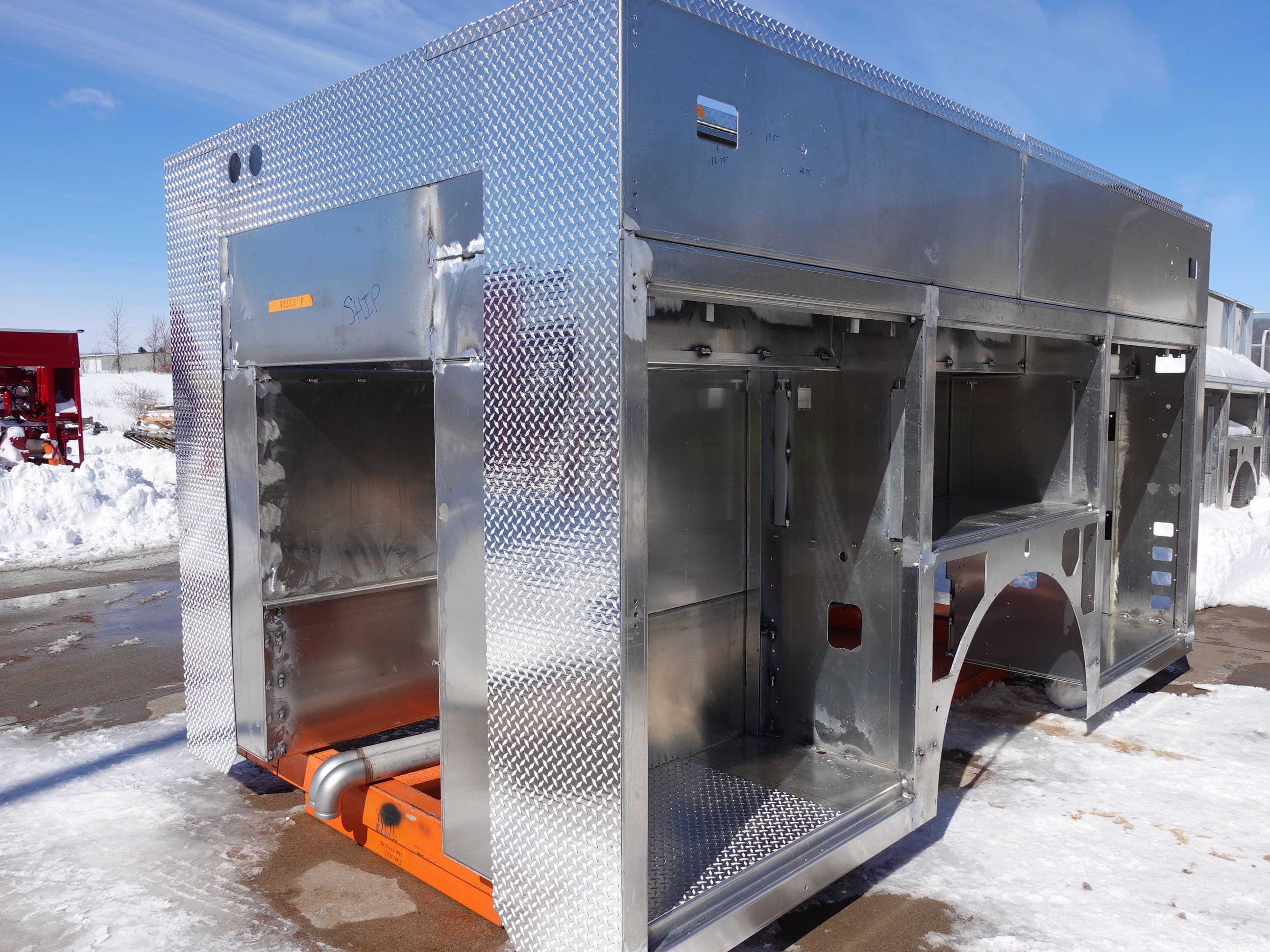

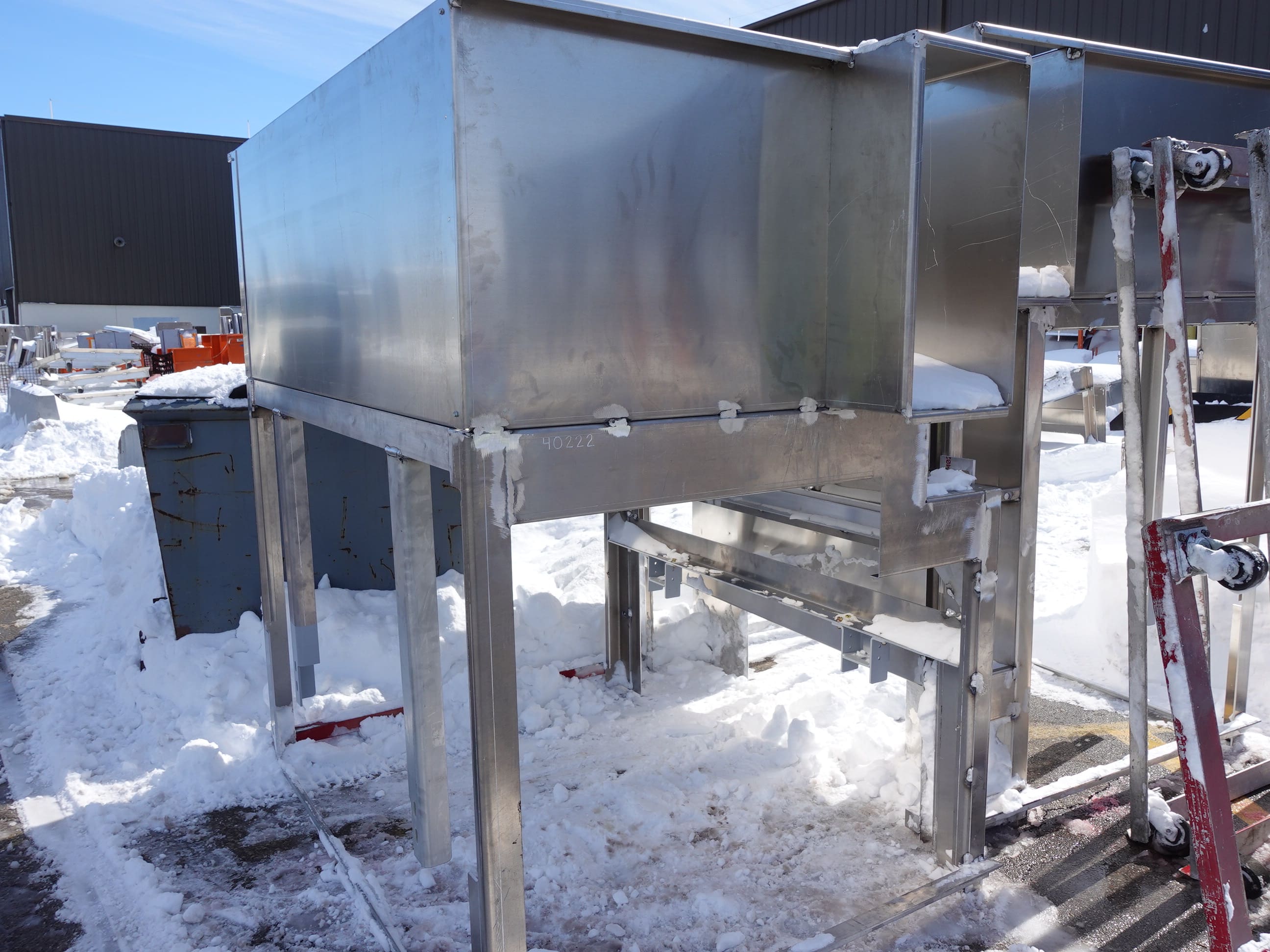

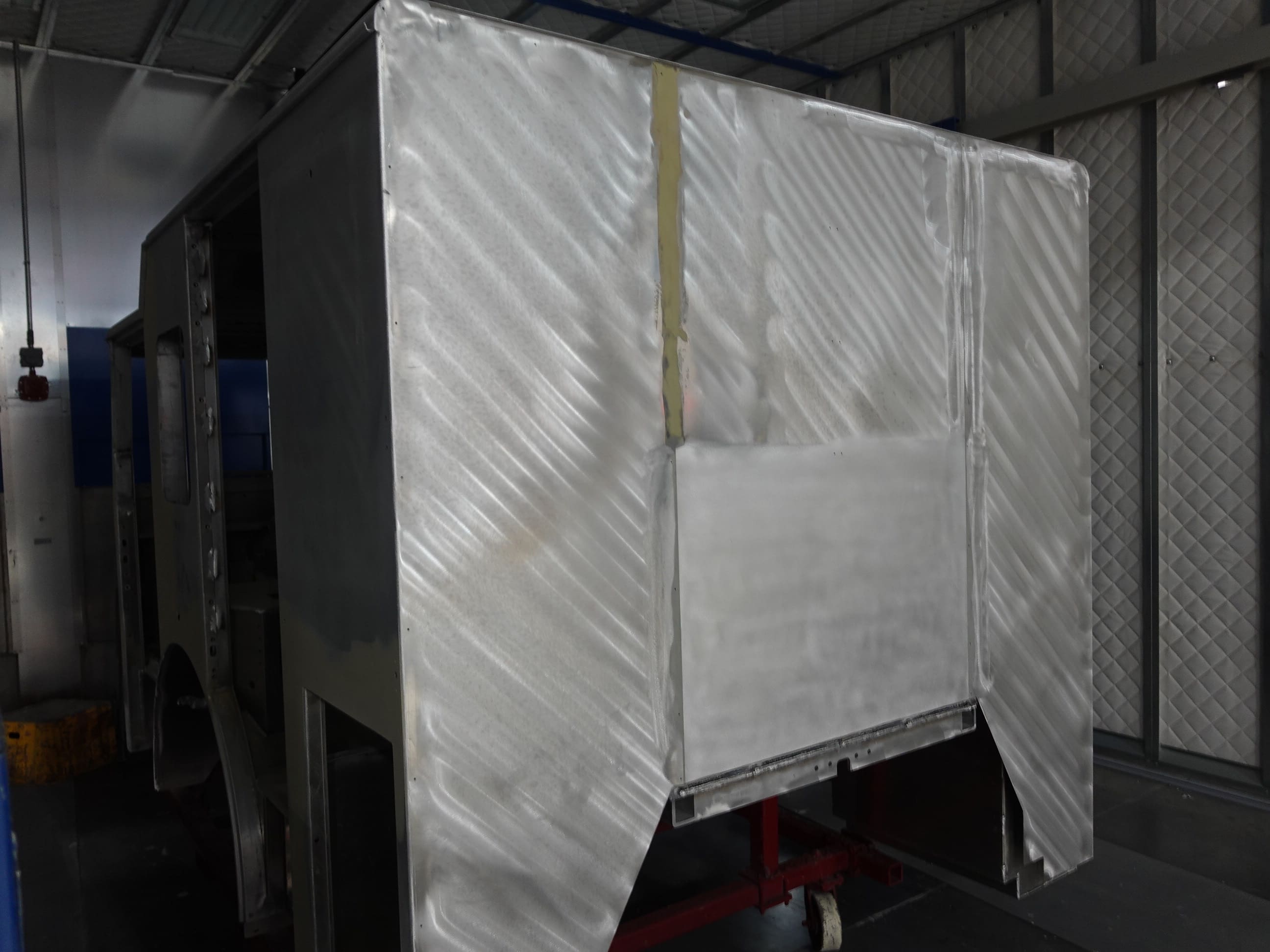

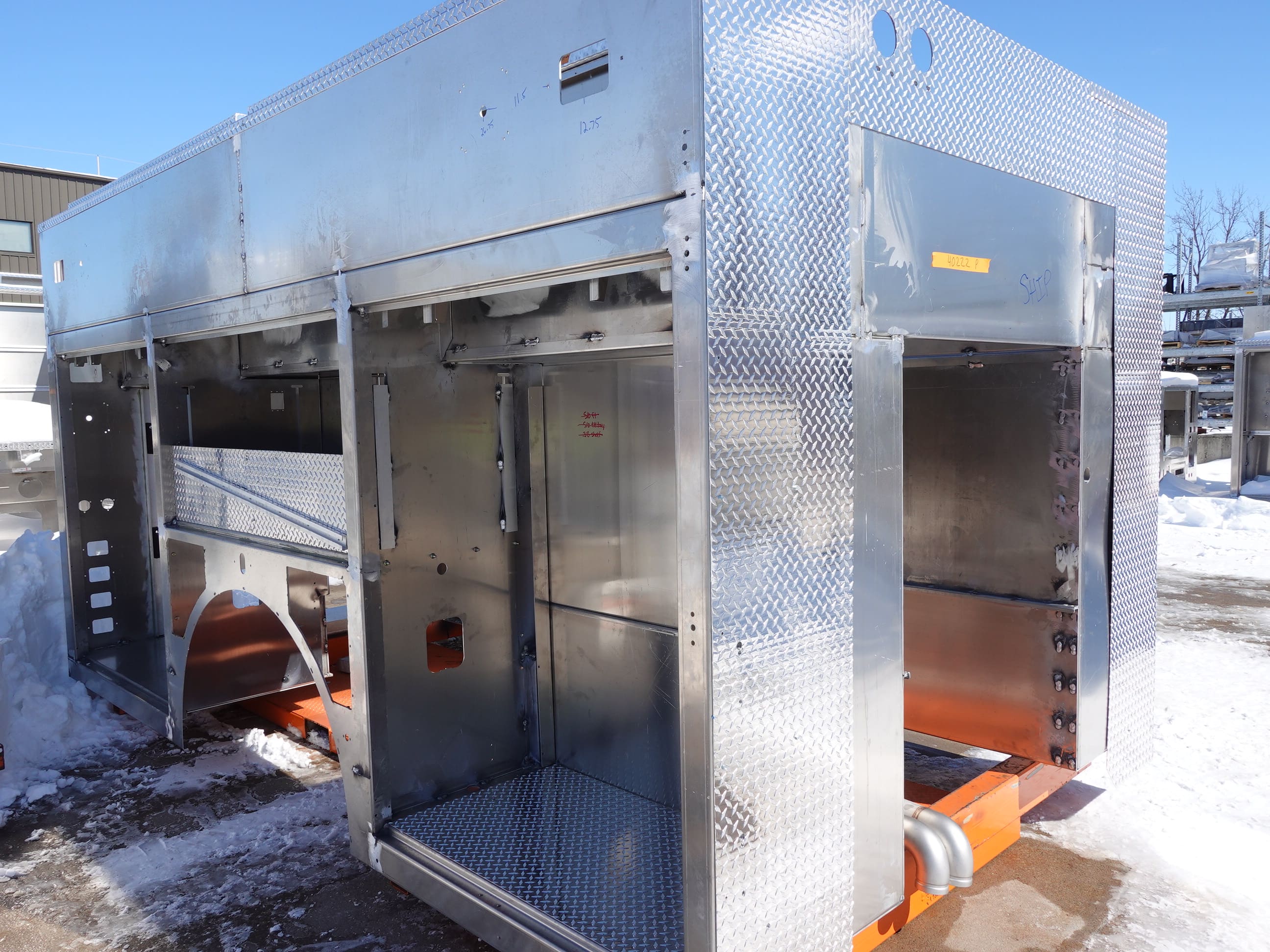

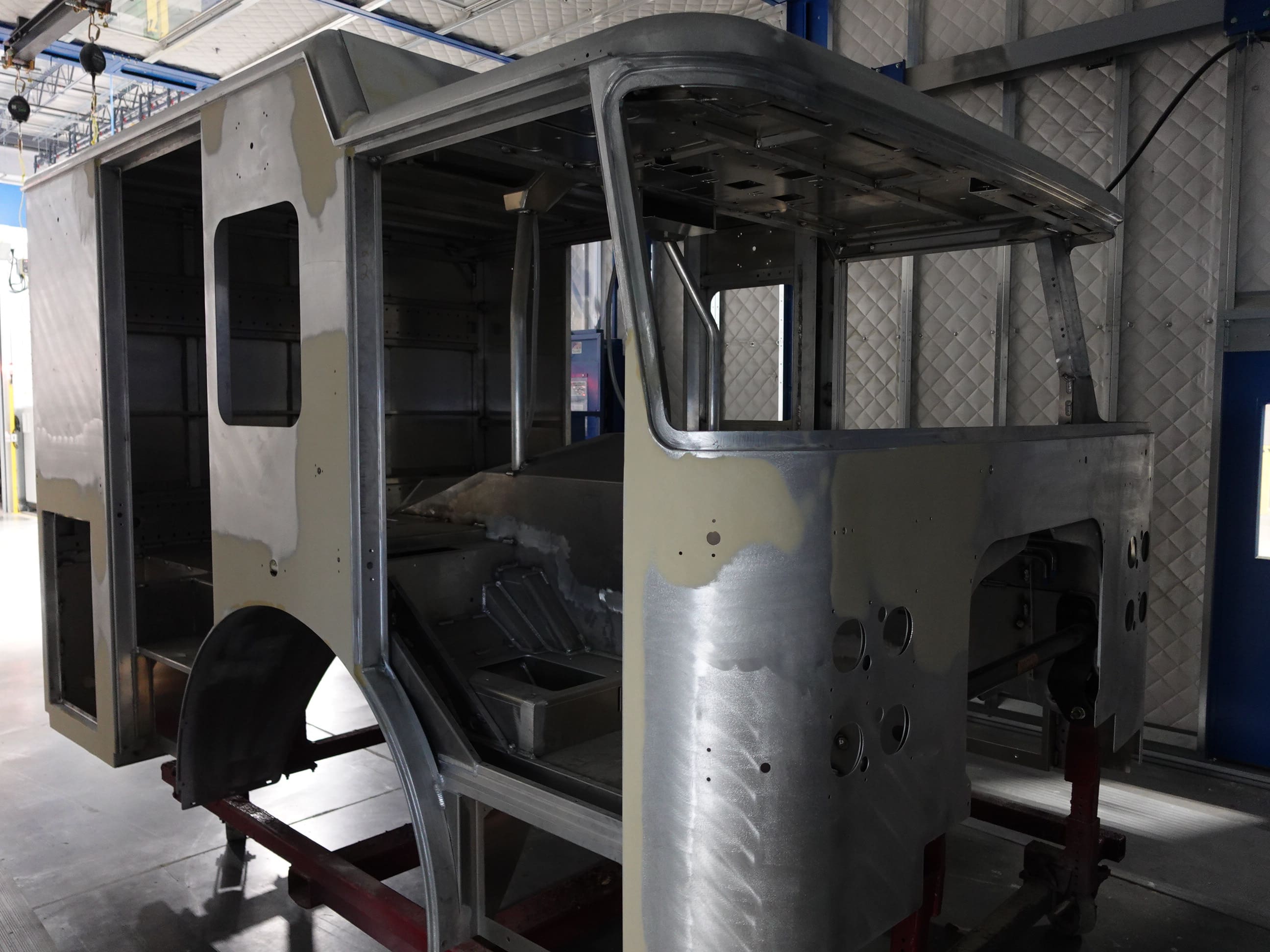

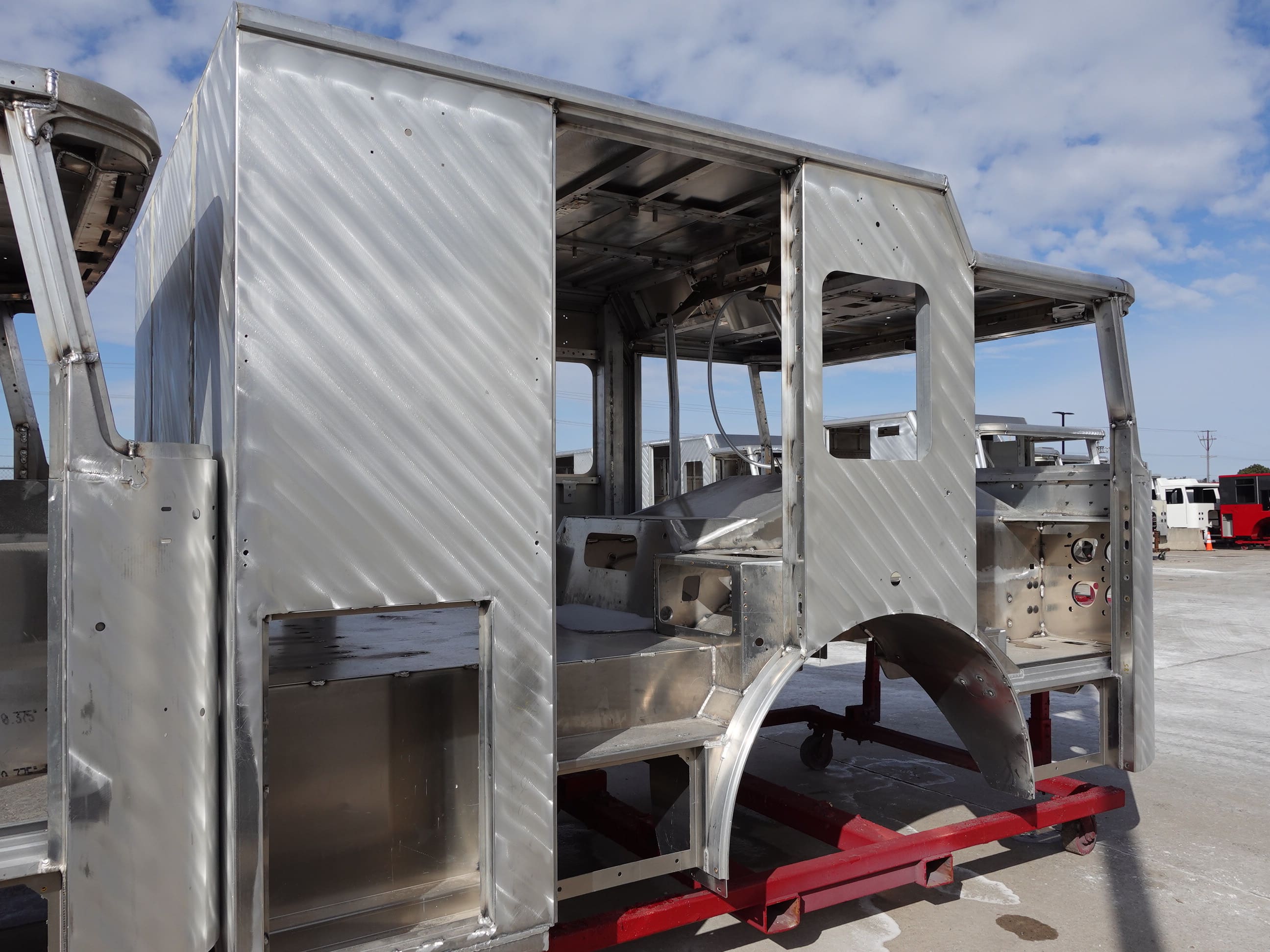

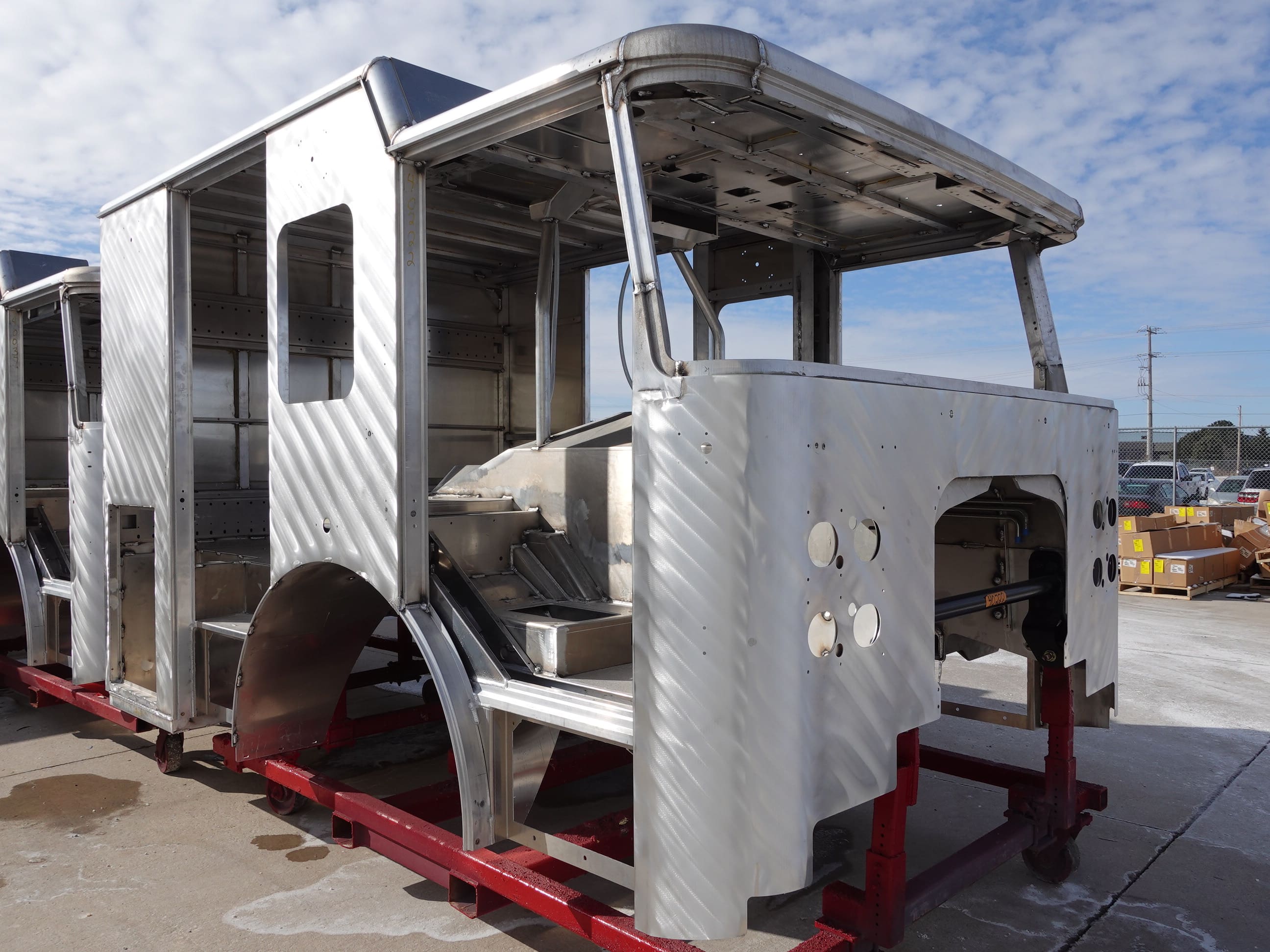

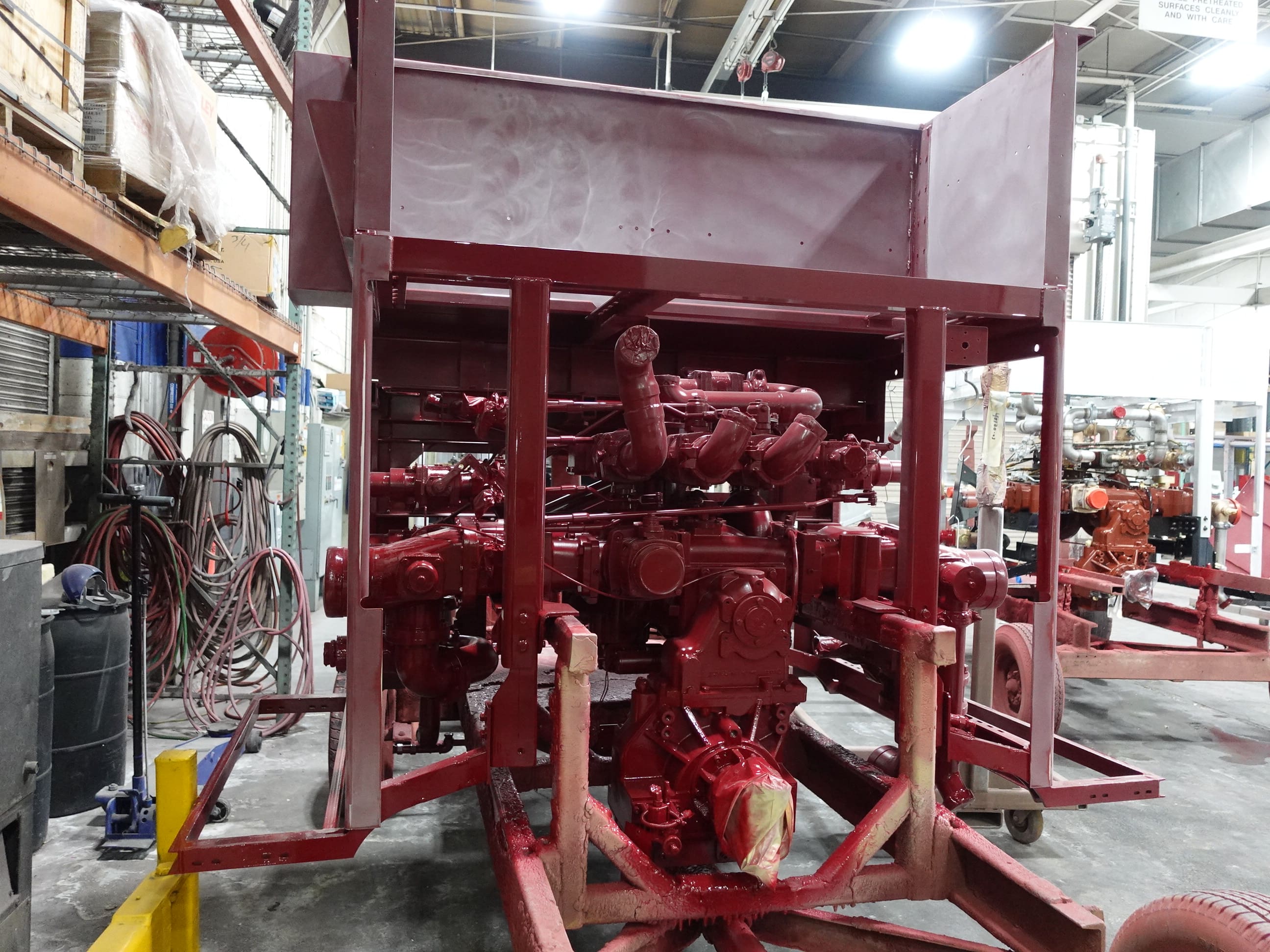

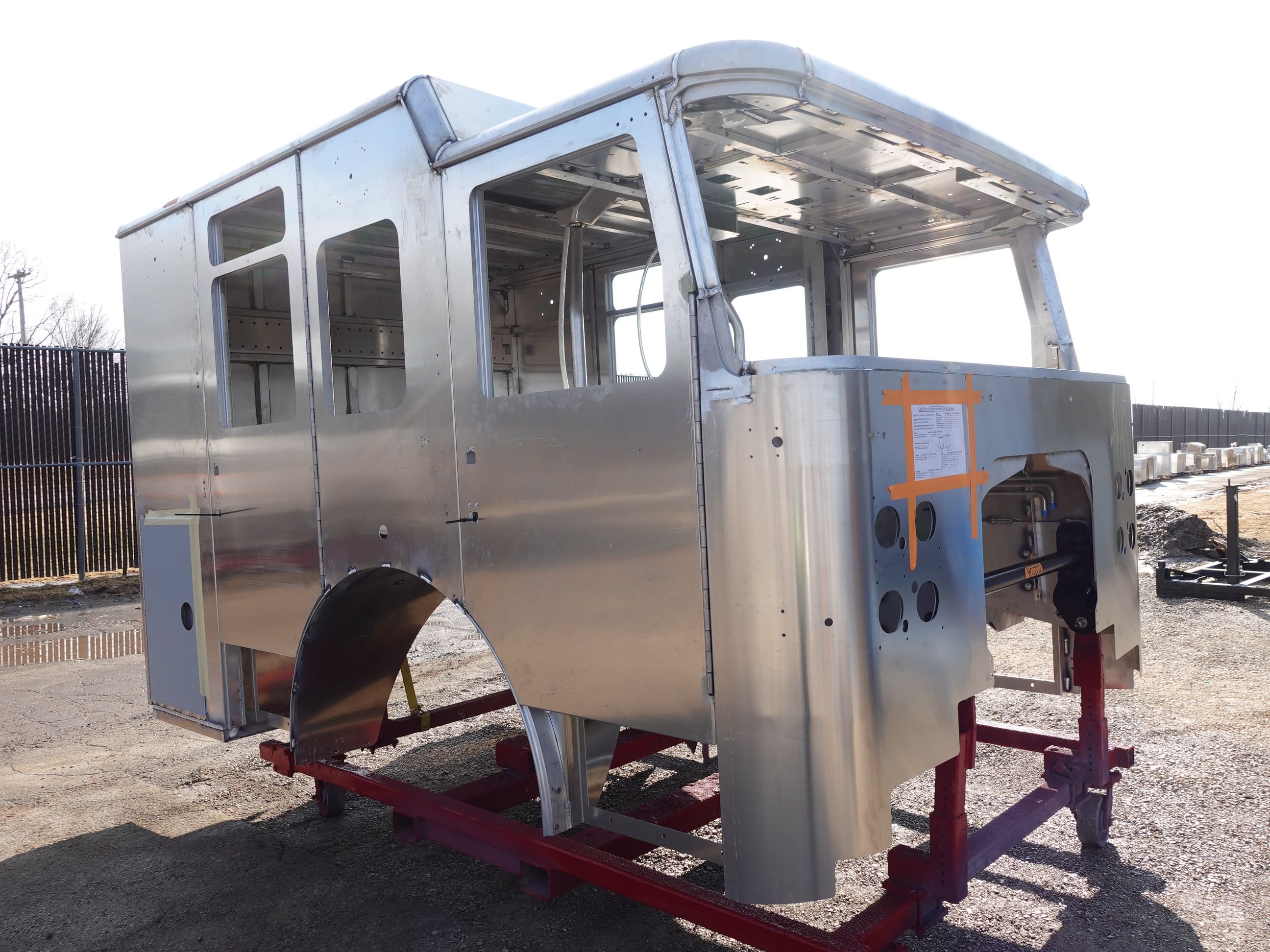

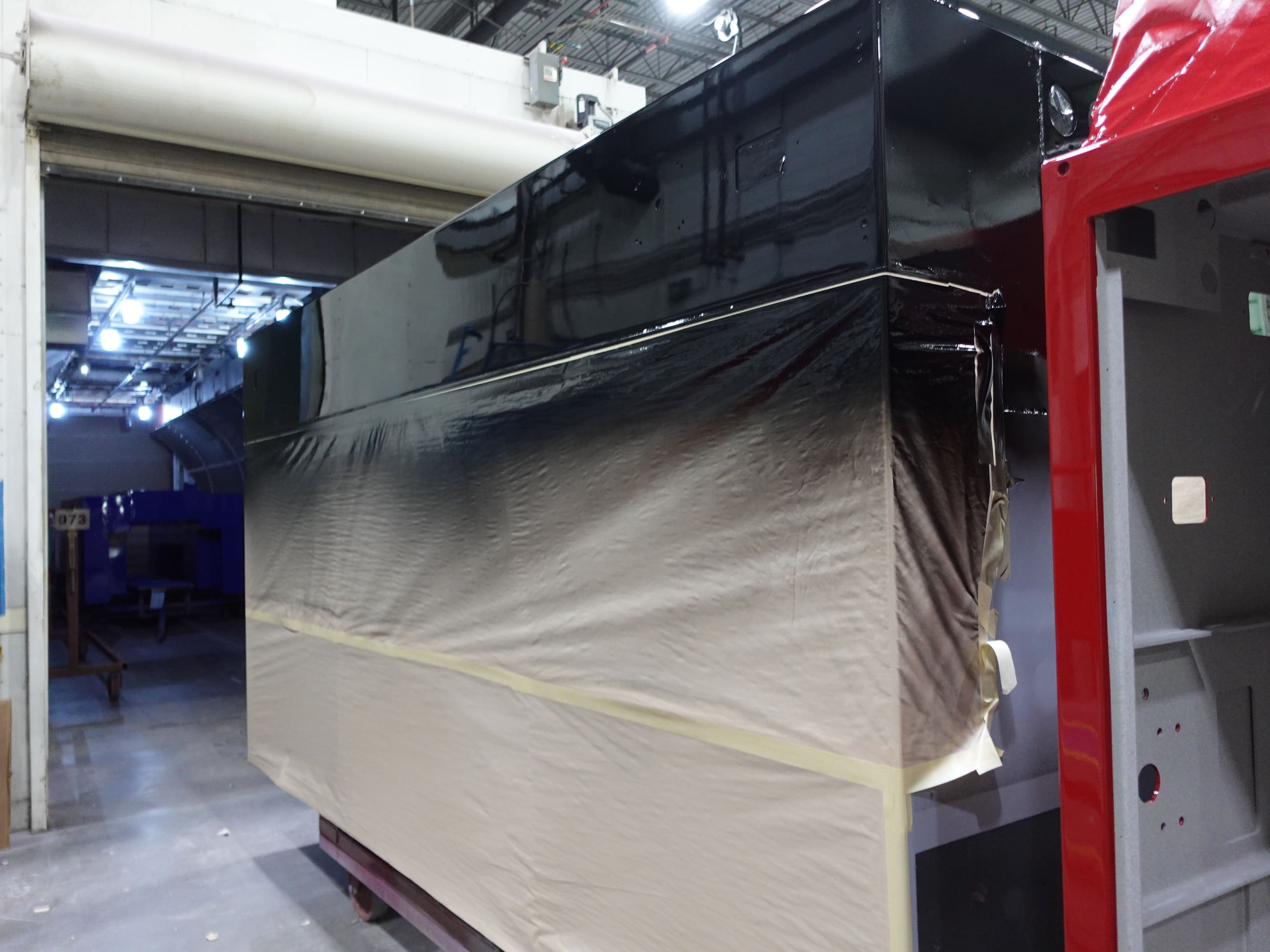

In this report, the cab continued through paint, the pump house structure was fabricated, and the body completed fabrication.
03-13-26
In this report, the cab continued the paint process while the body began fabrication.
