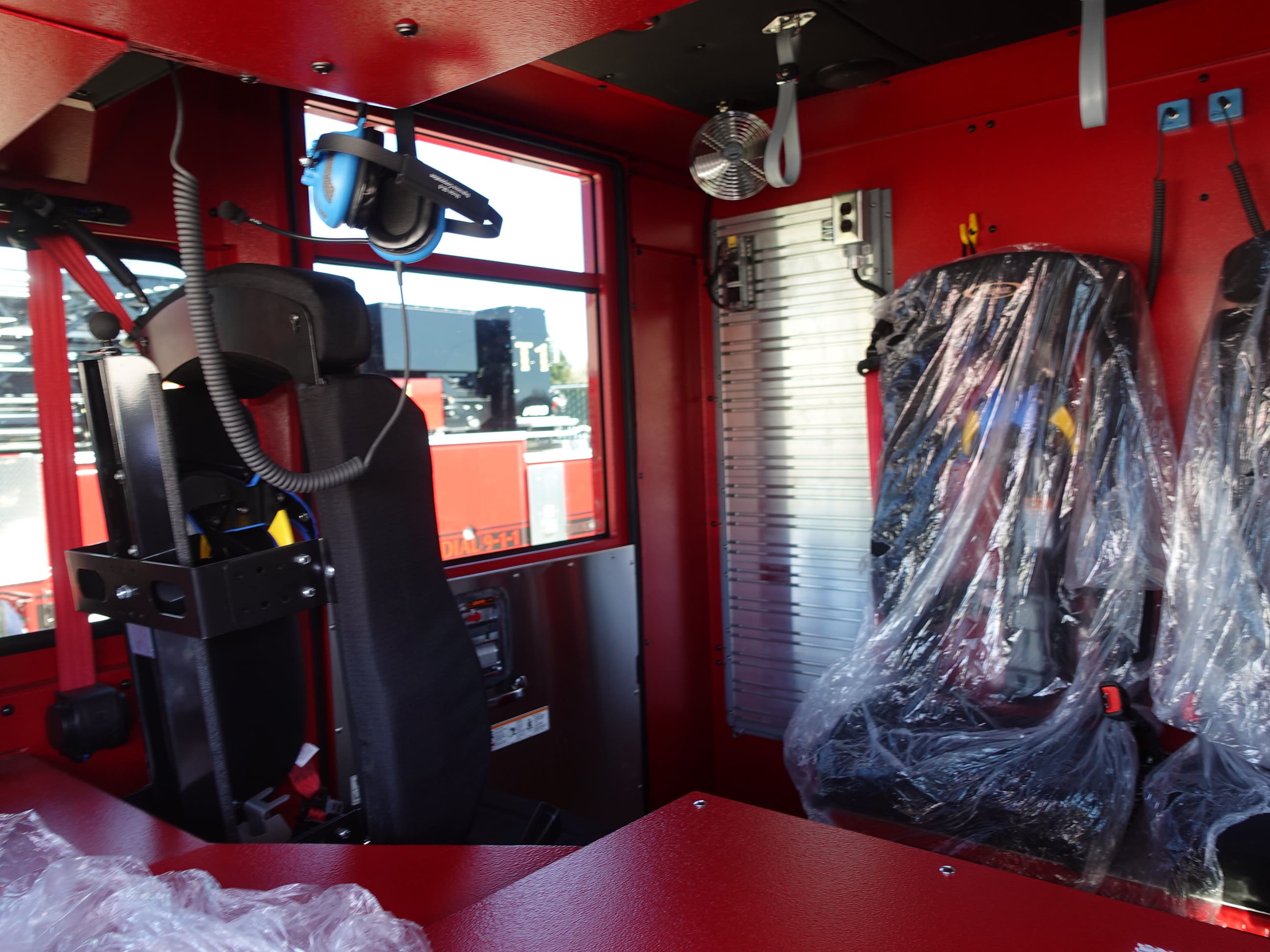

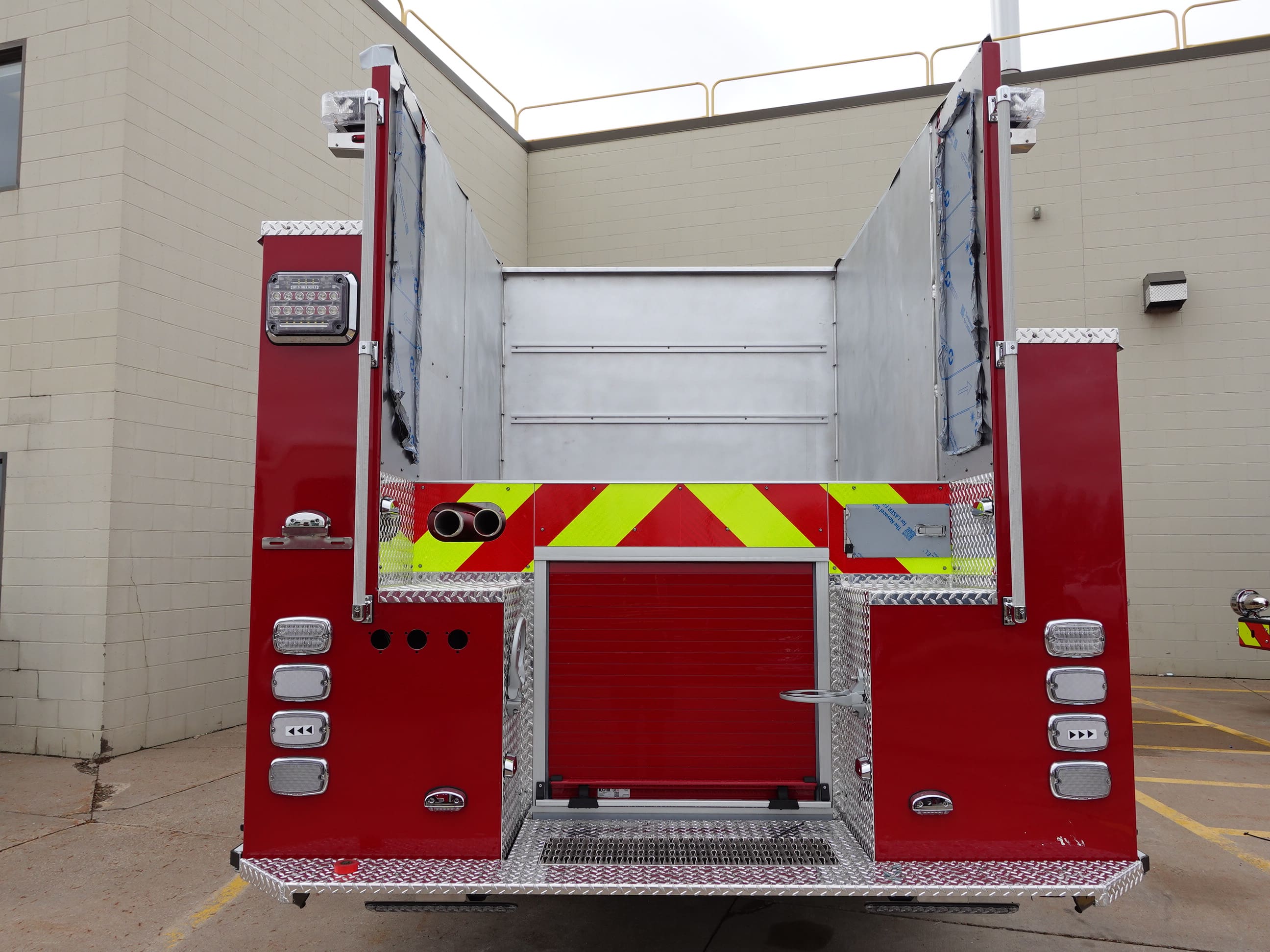

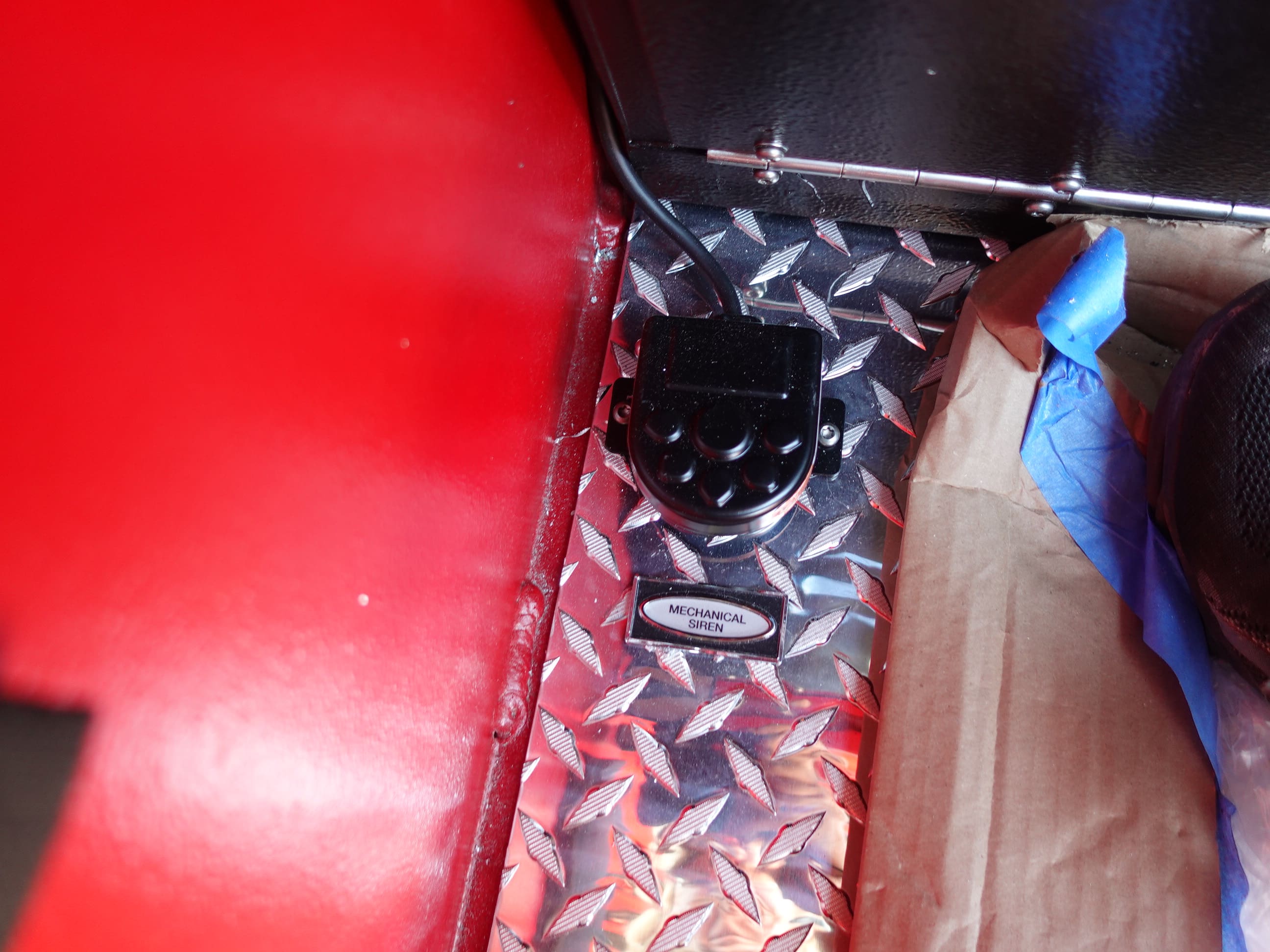

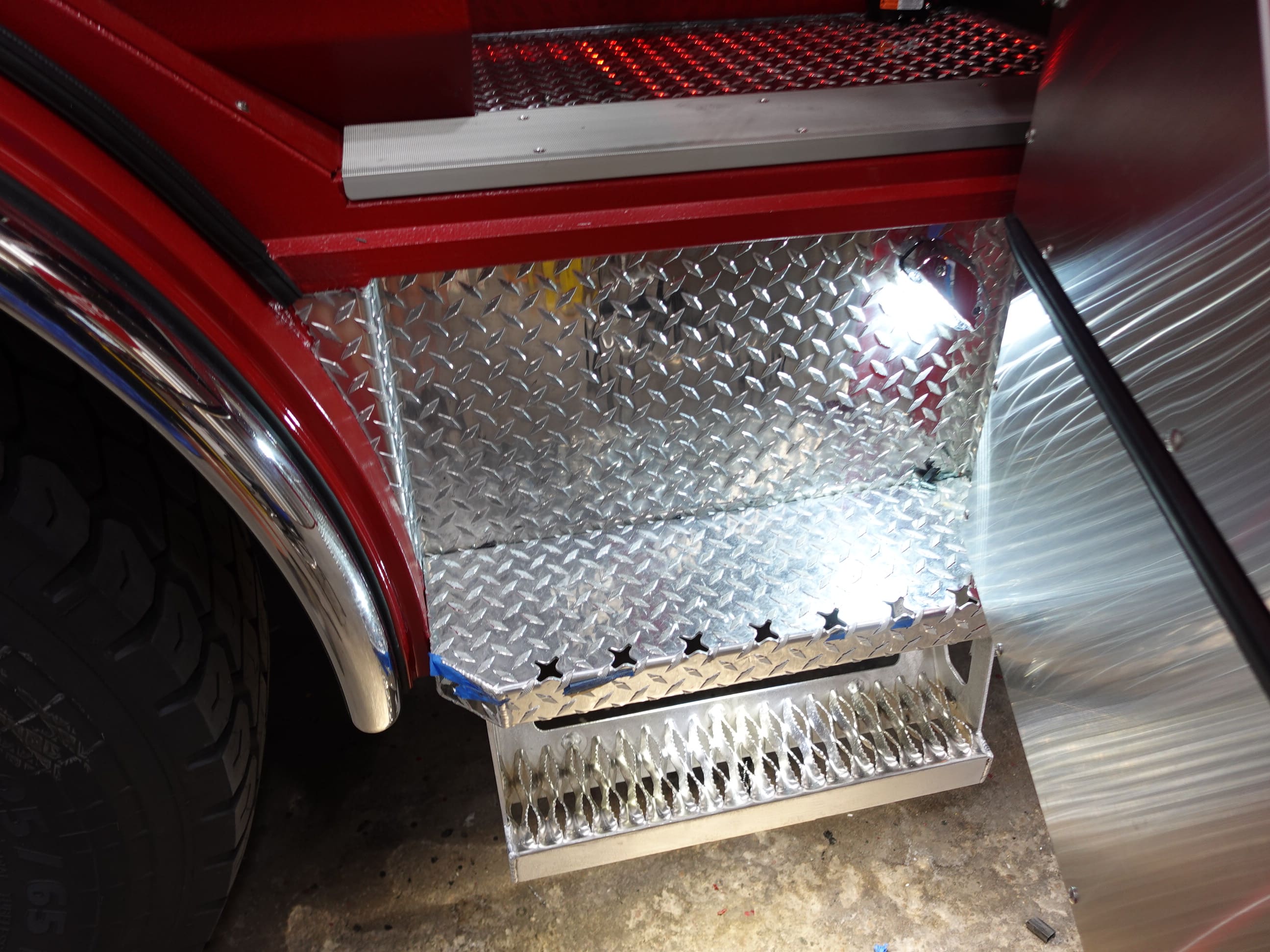

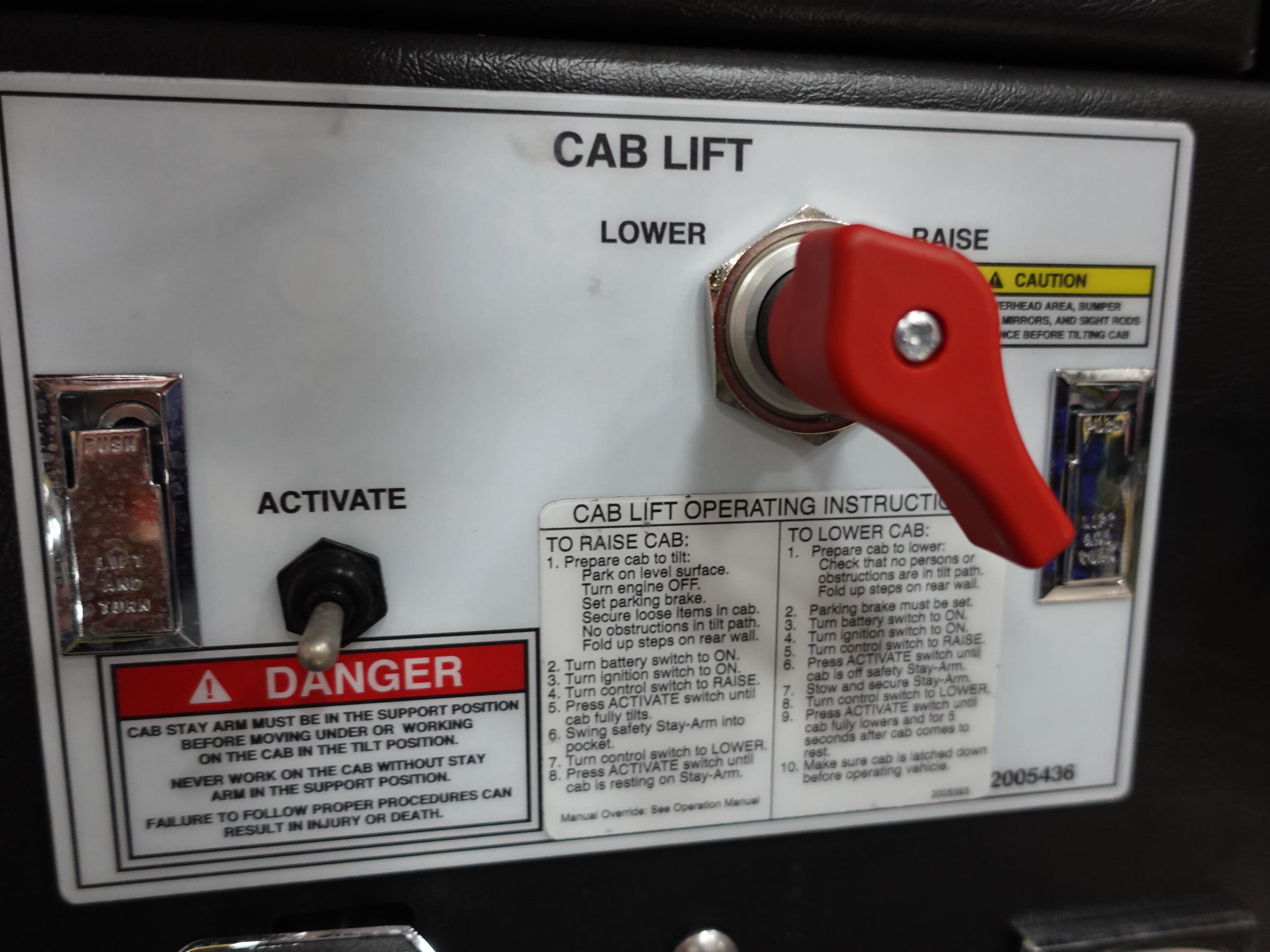

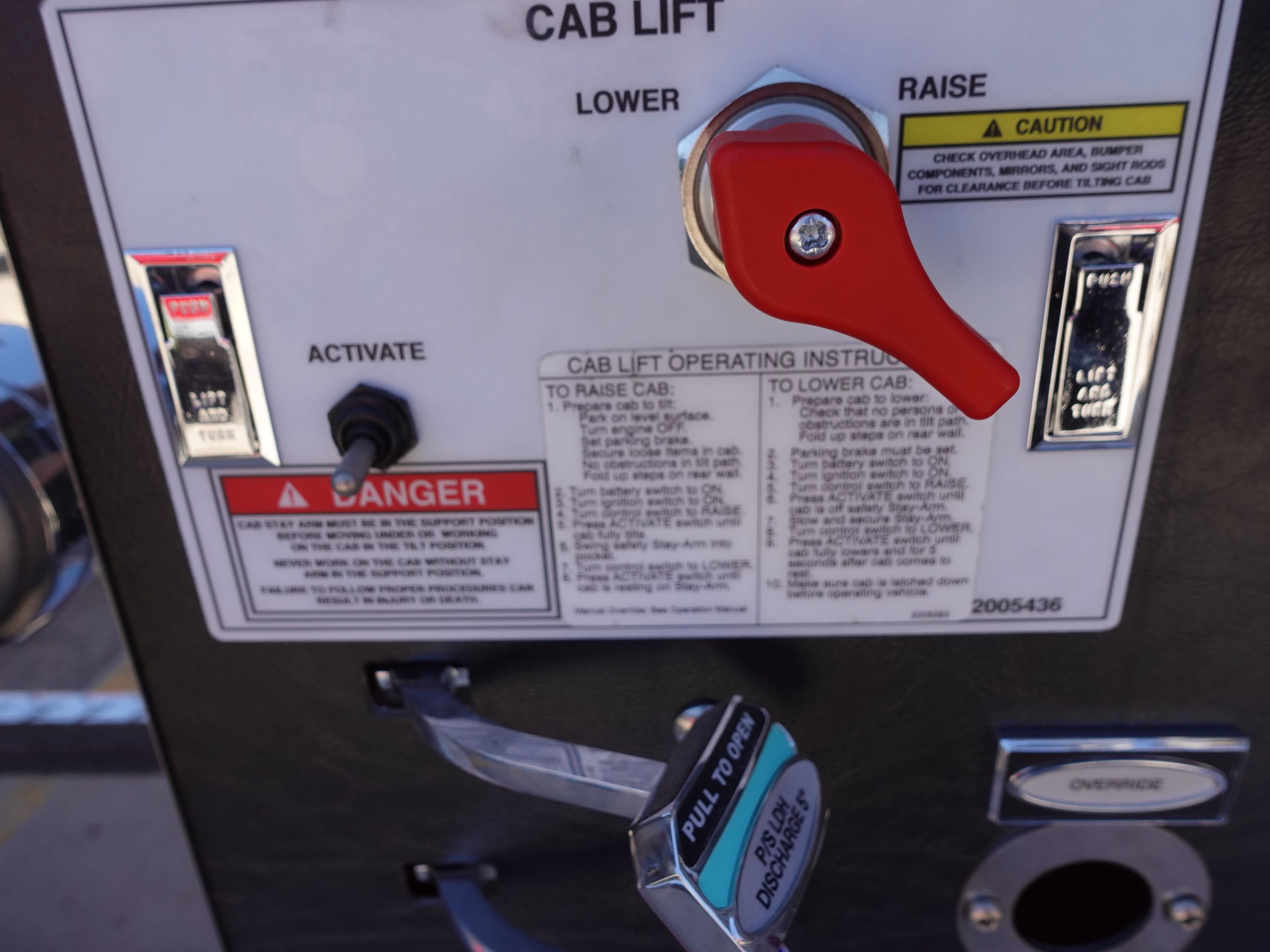

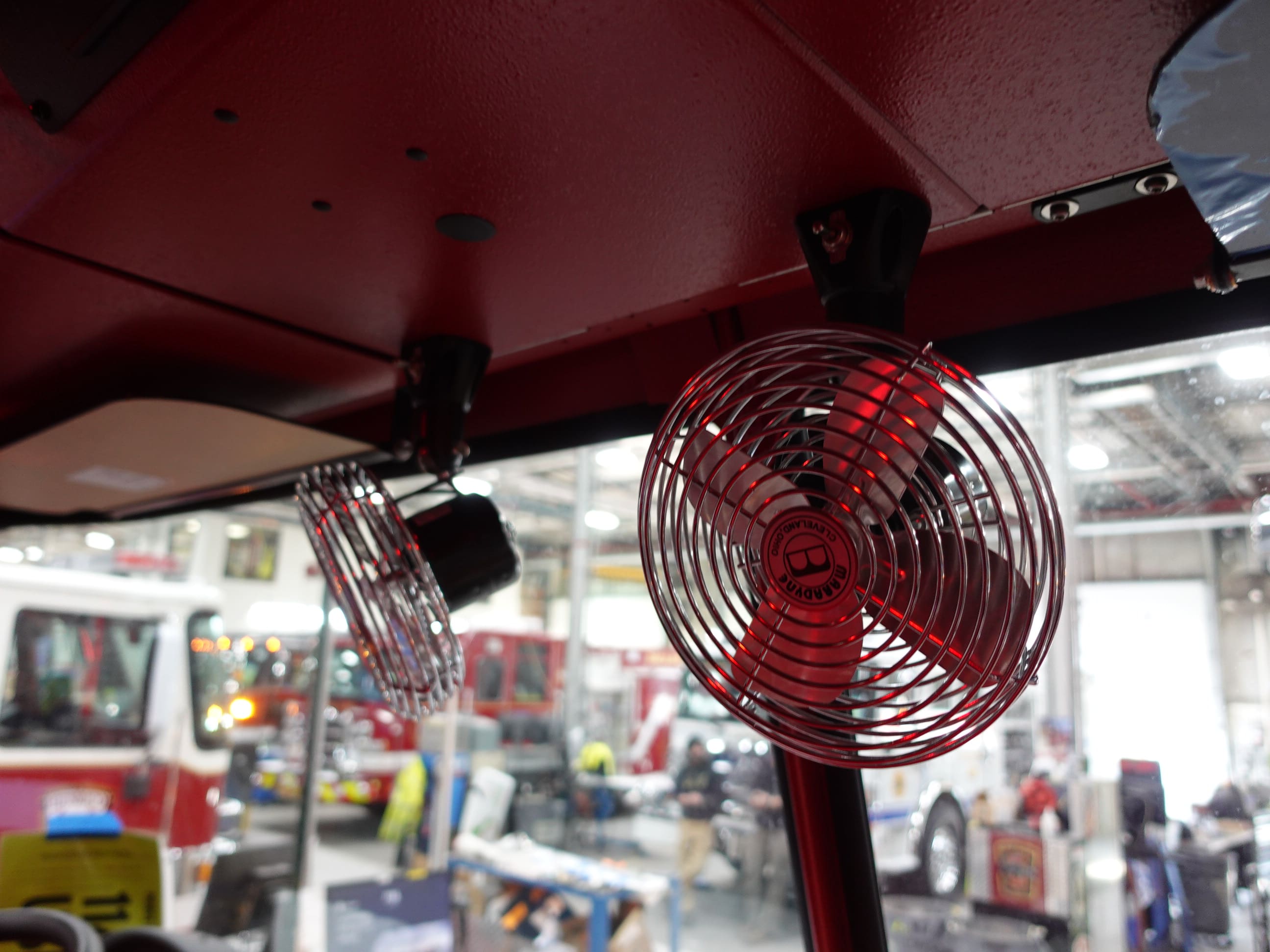

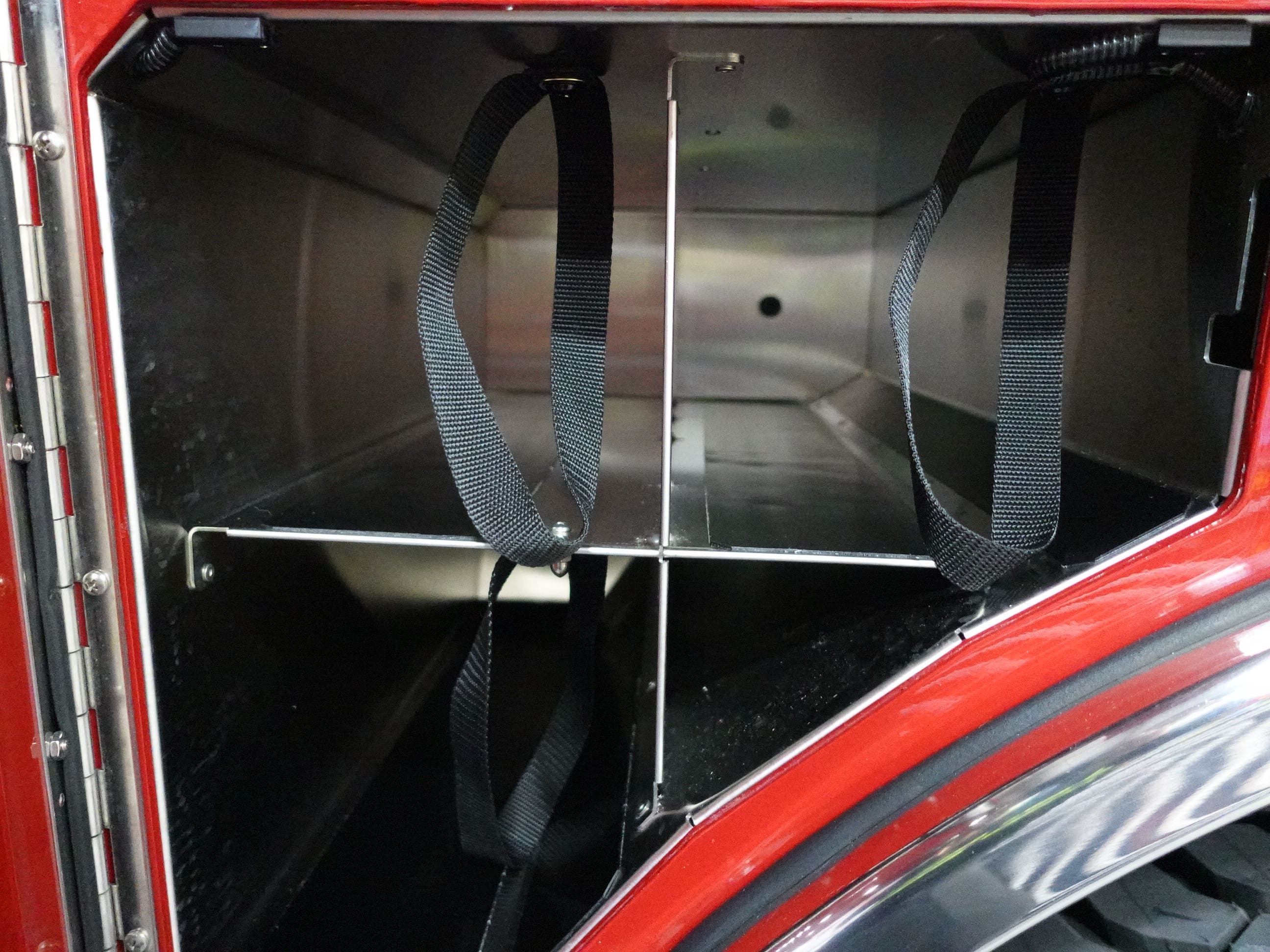

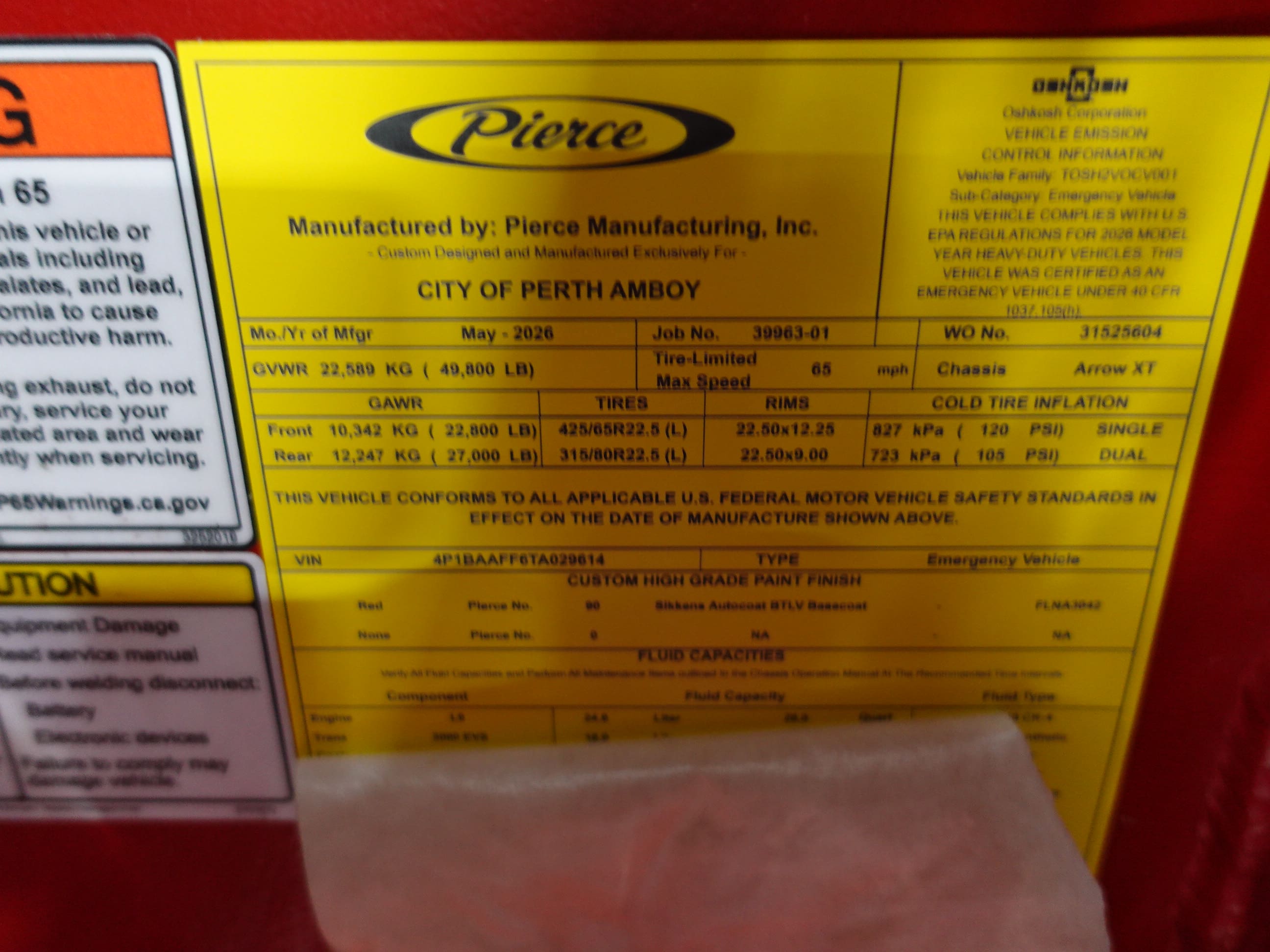

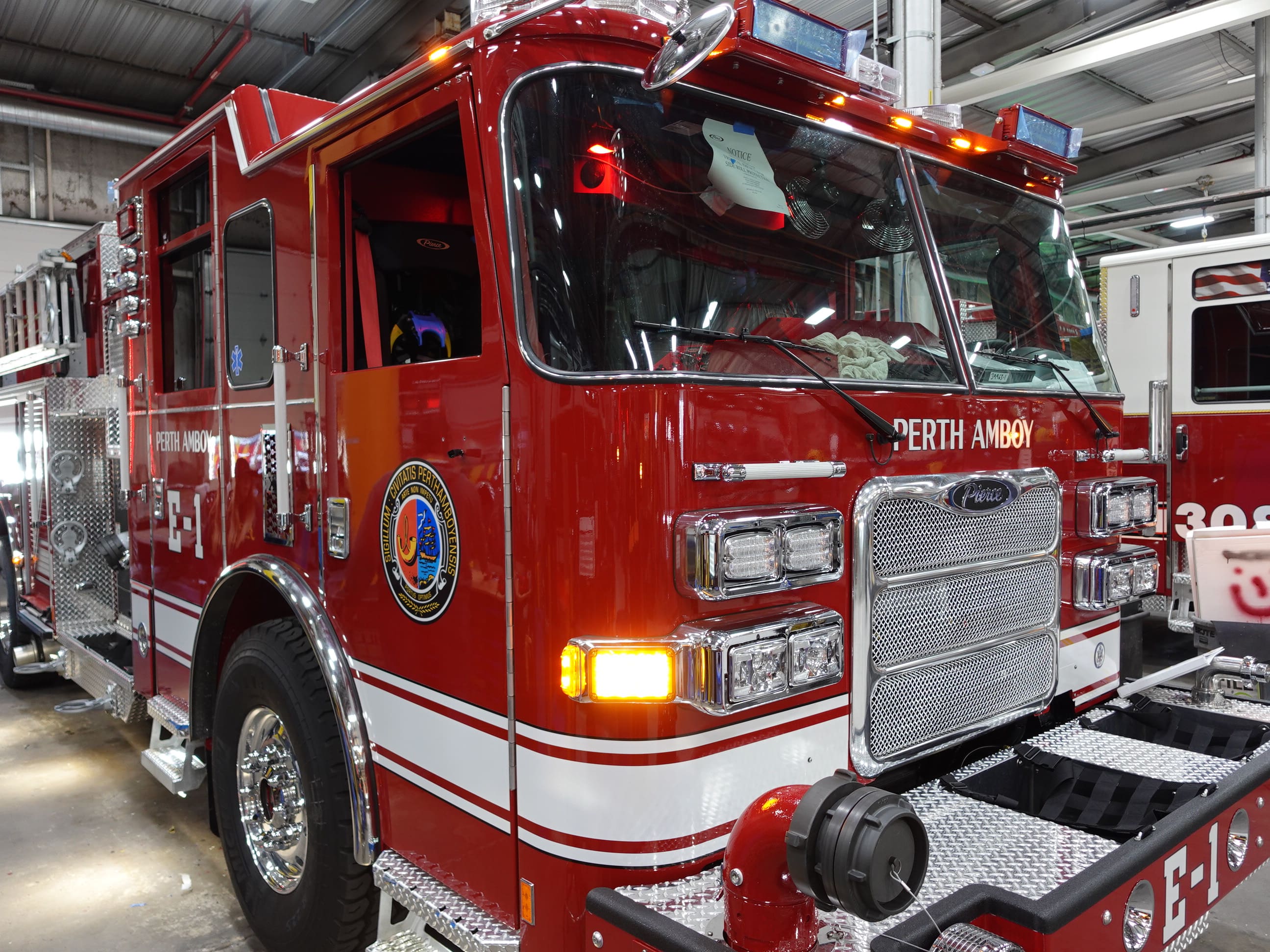

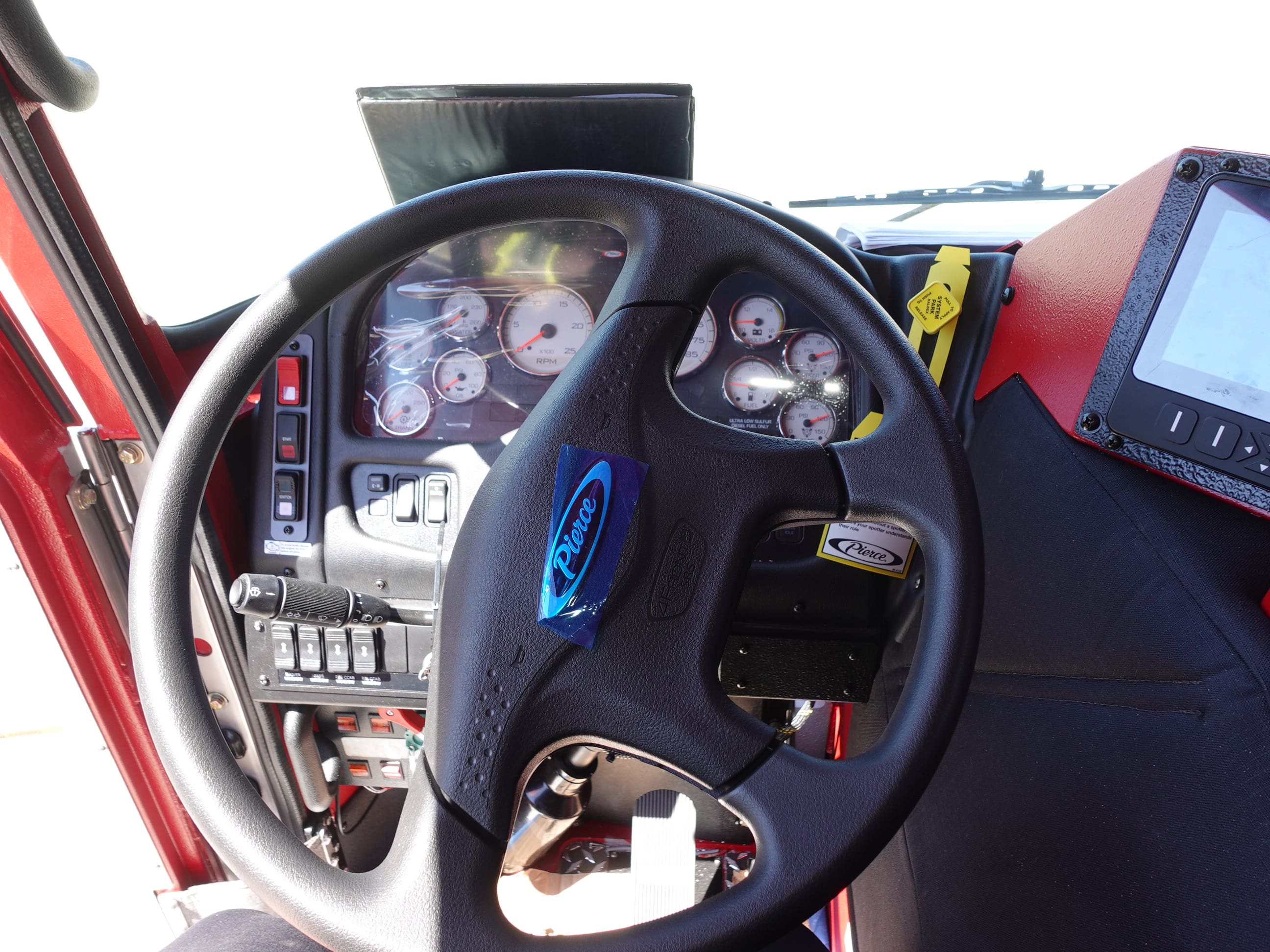

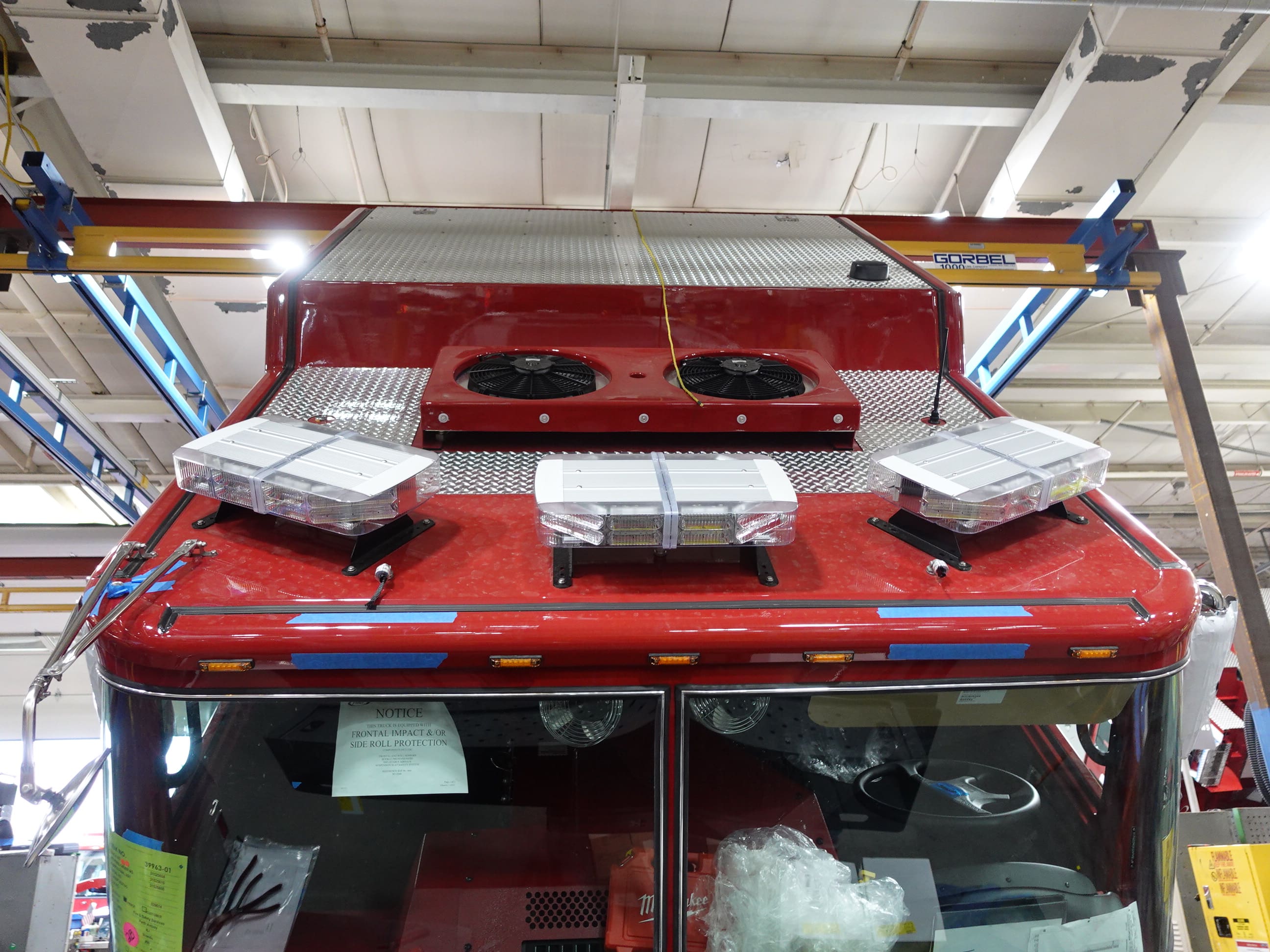

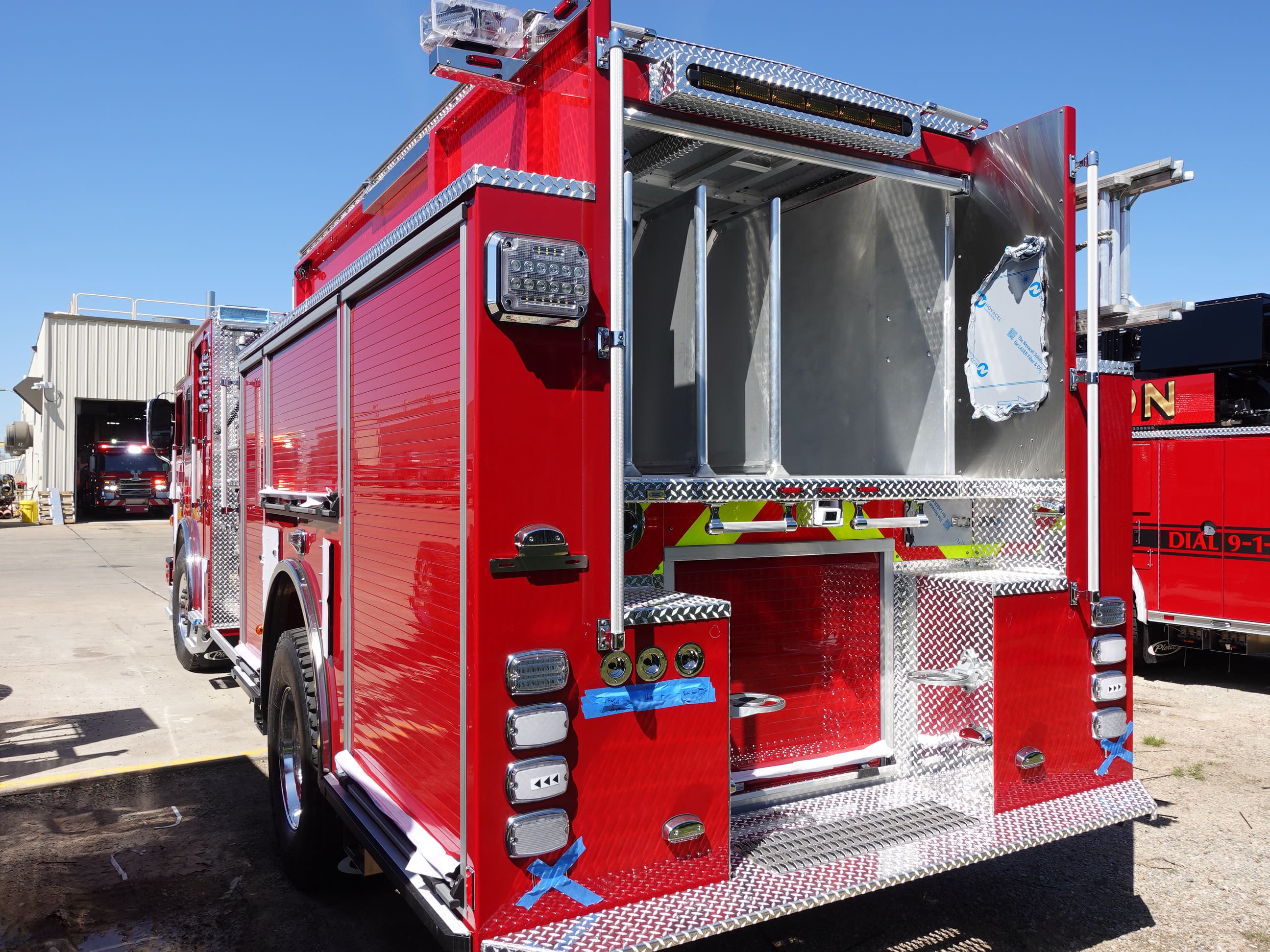

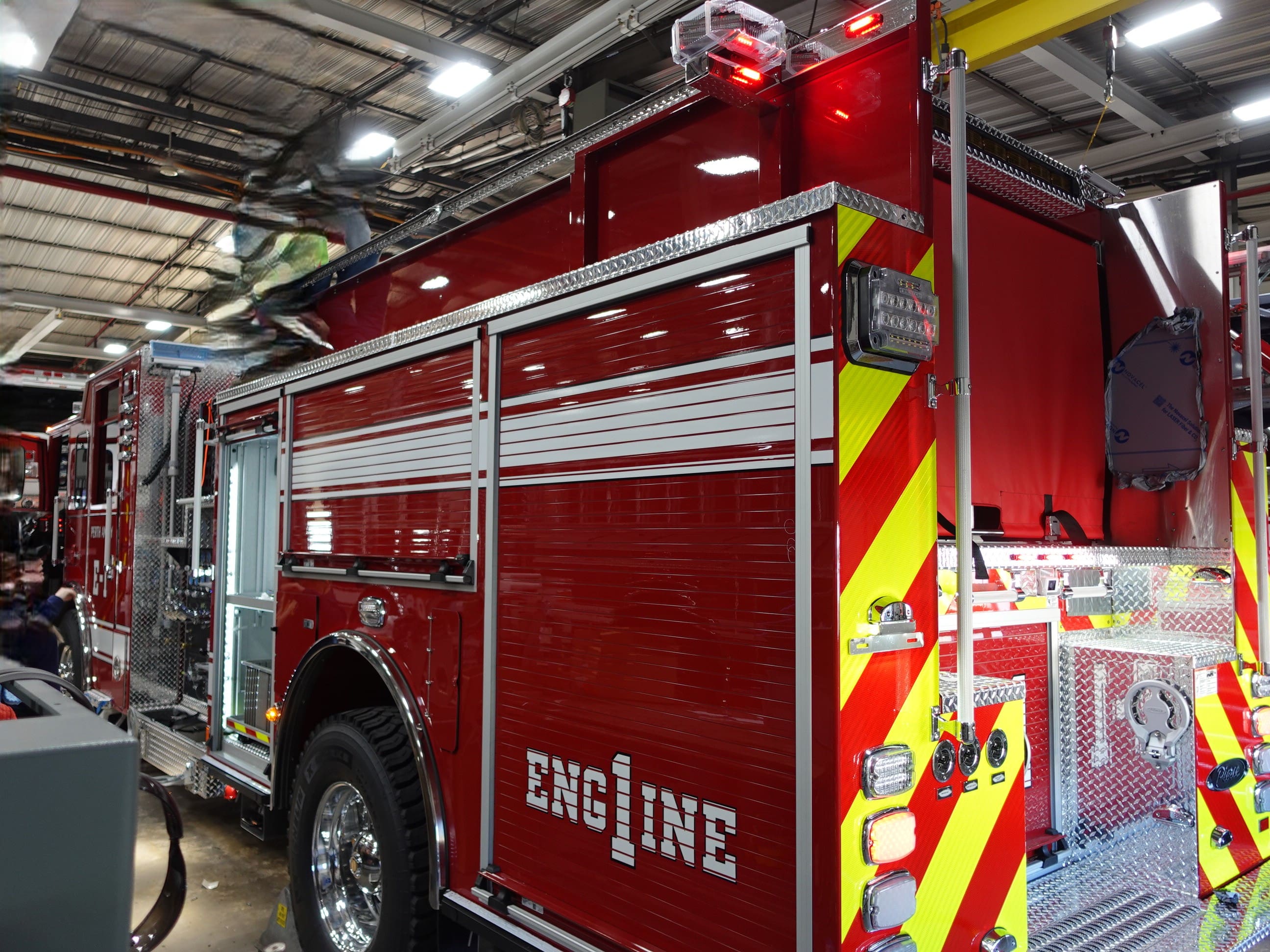

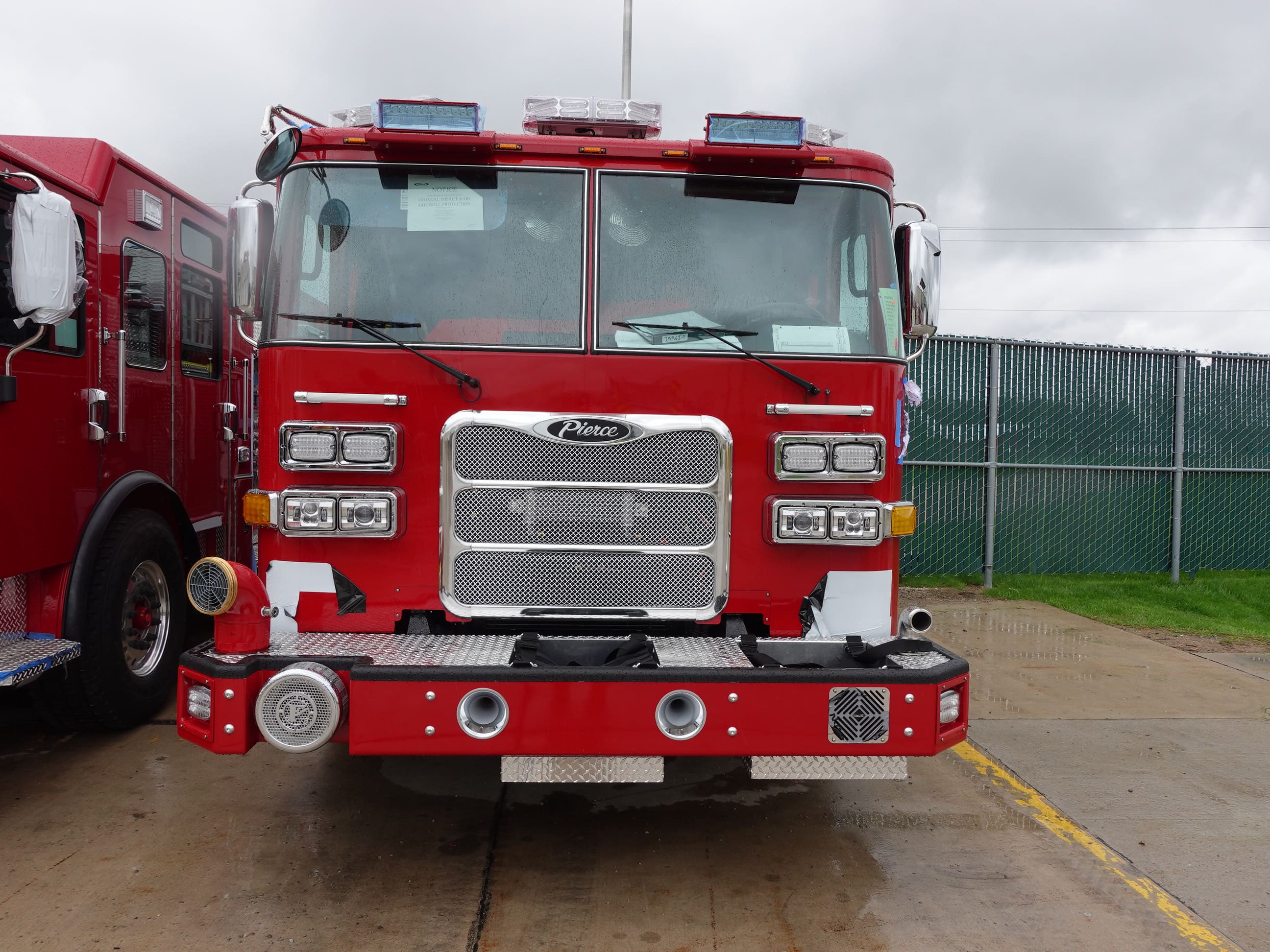

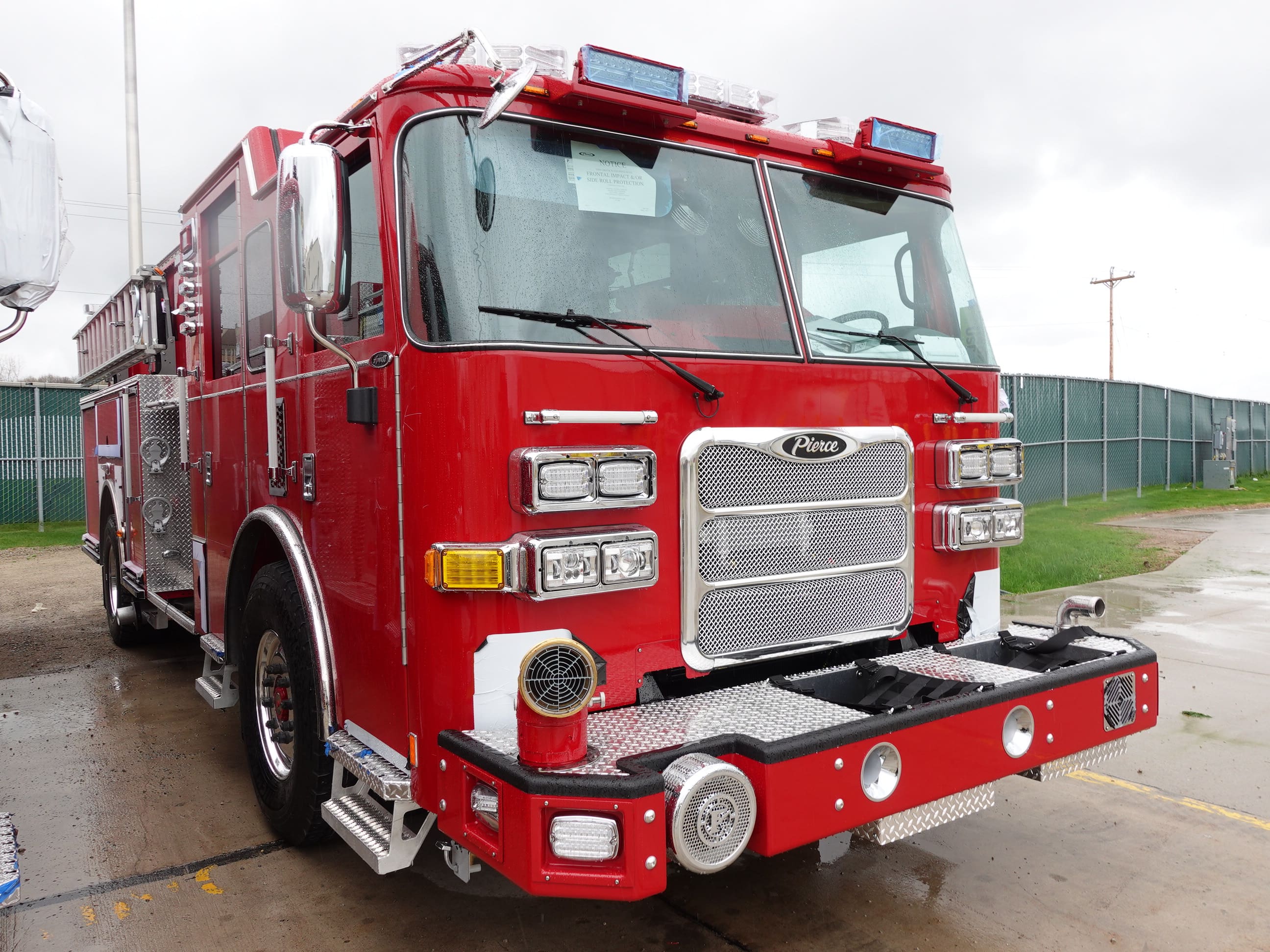

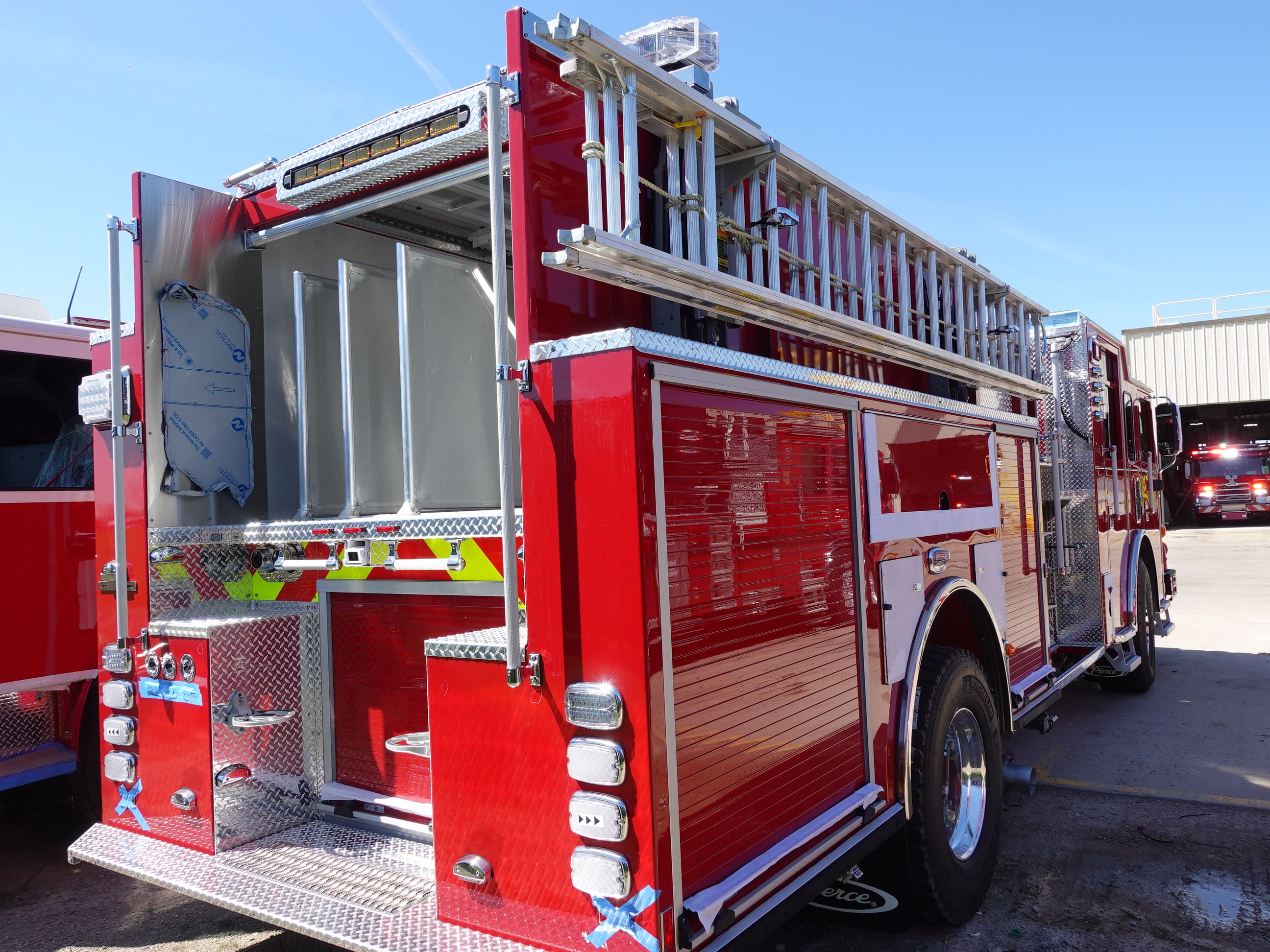

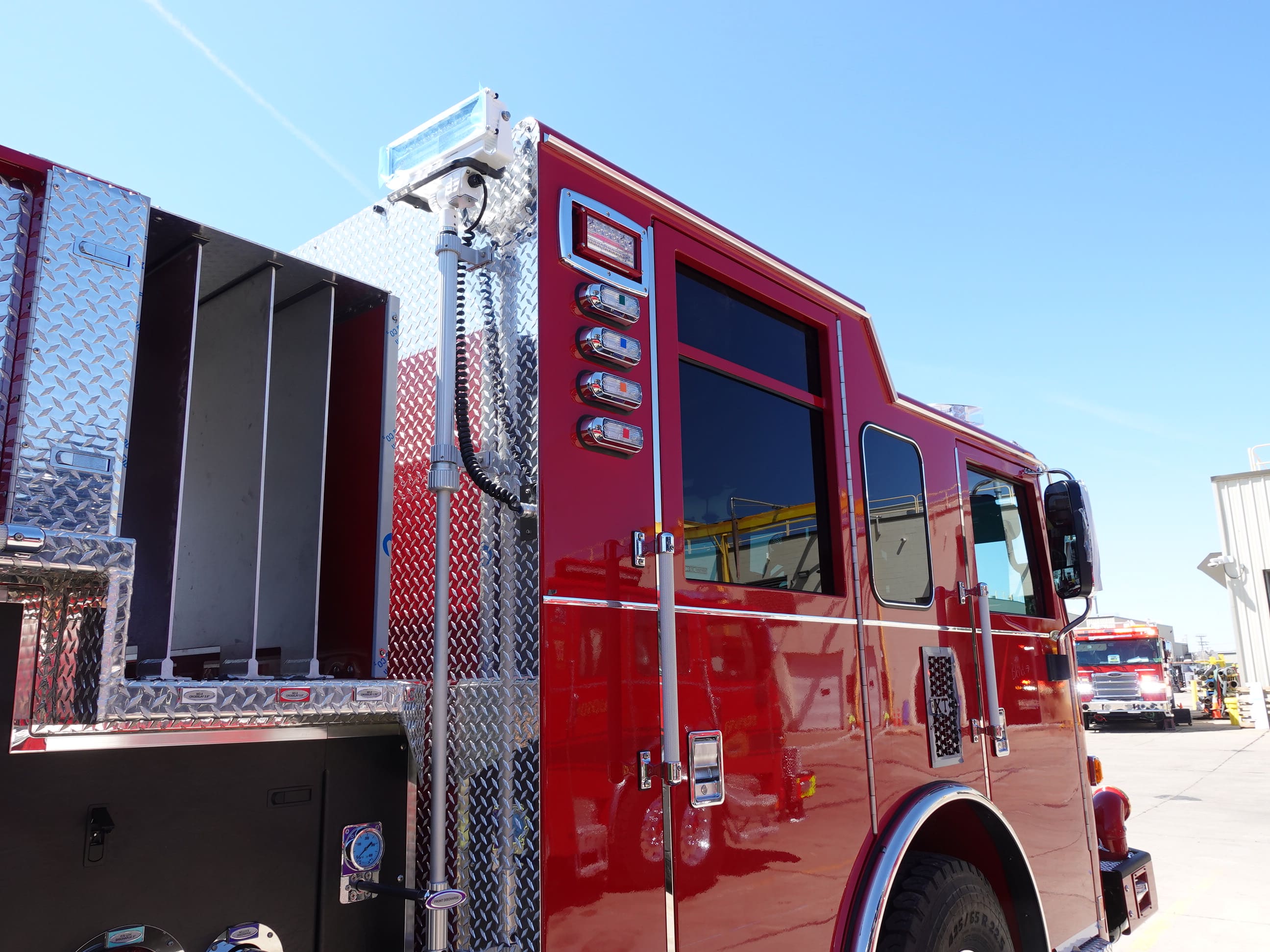

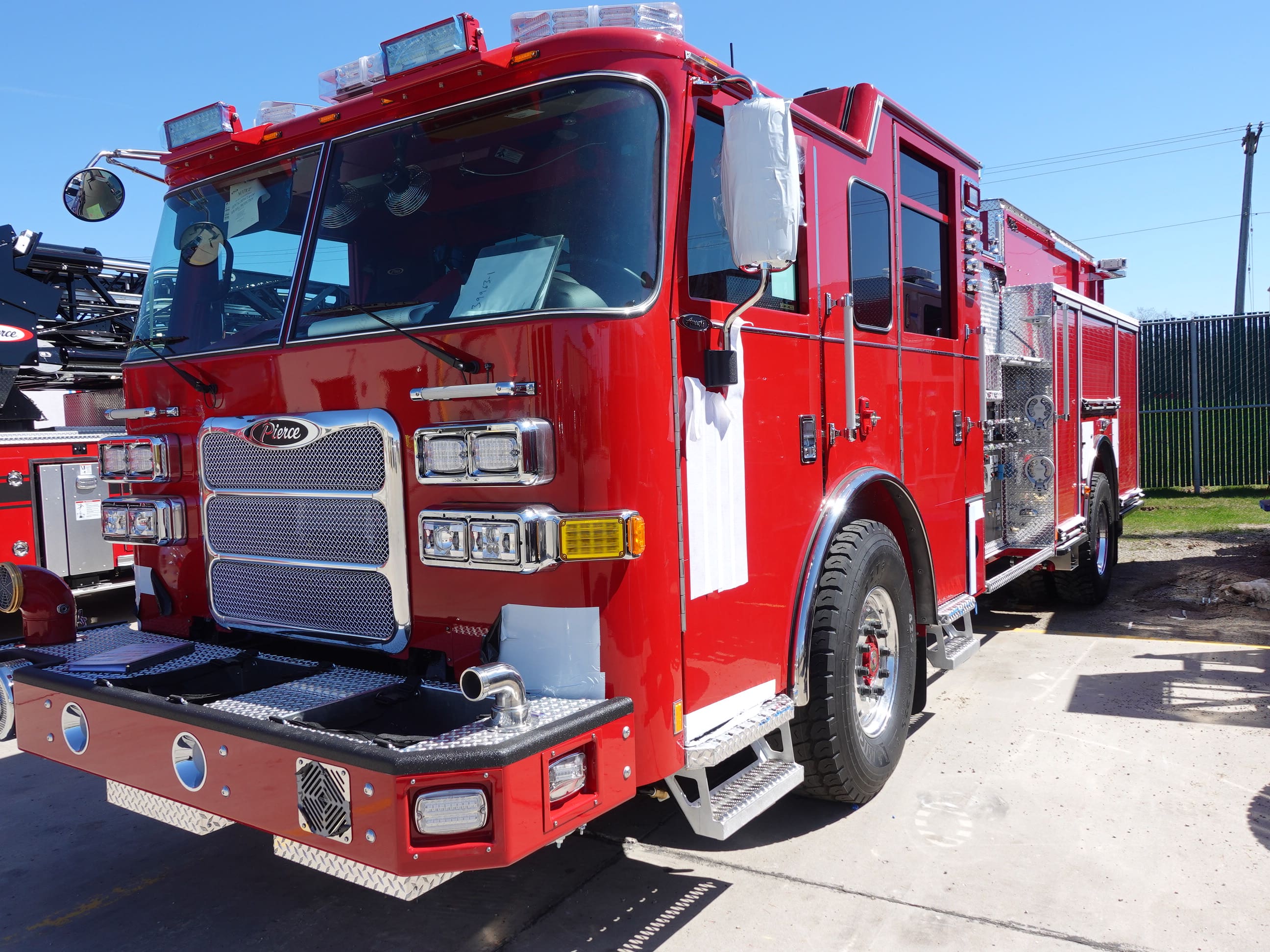

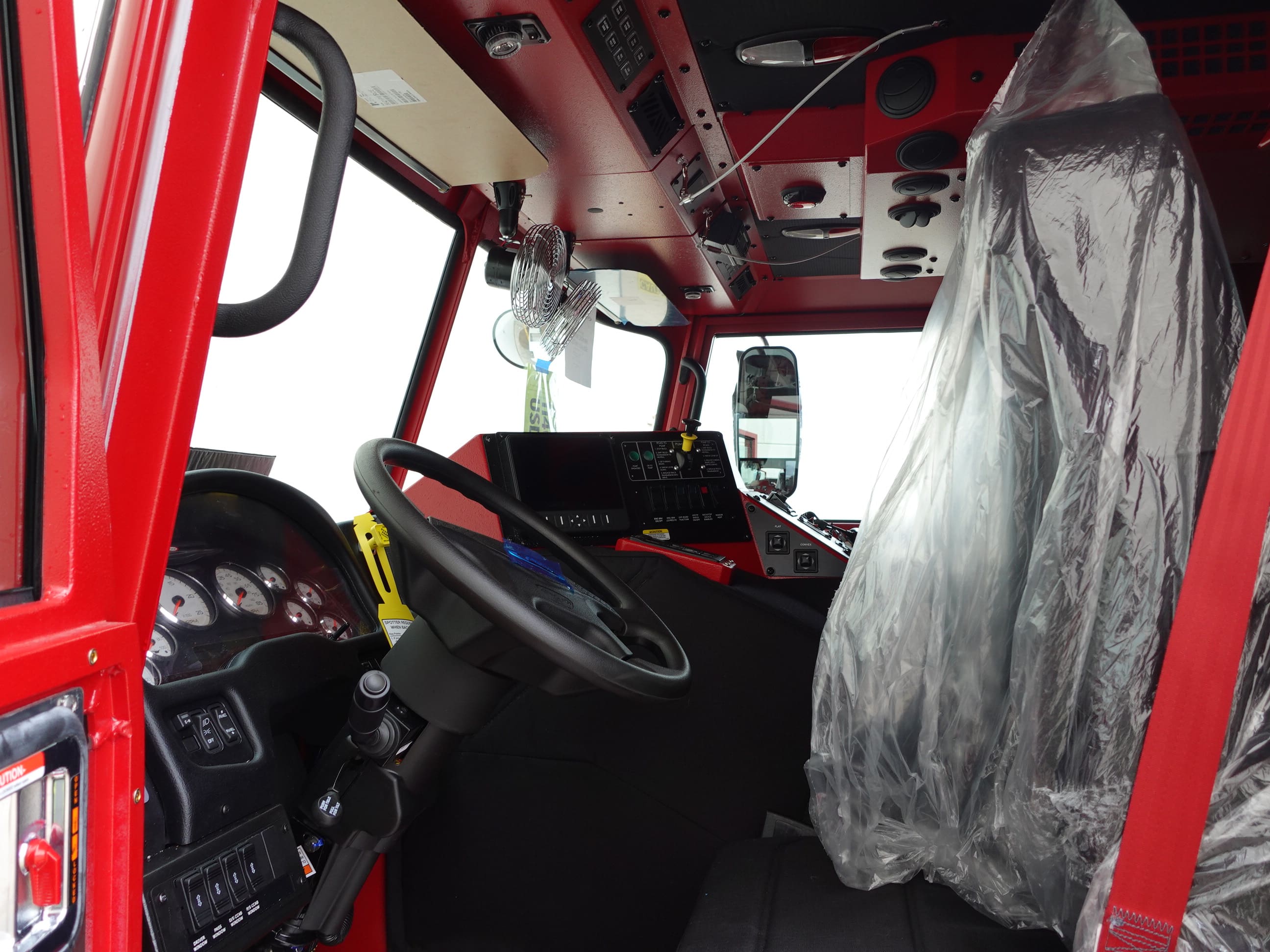

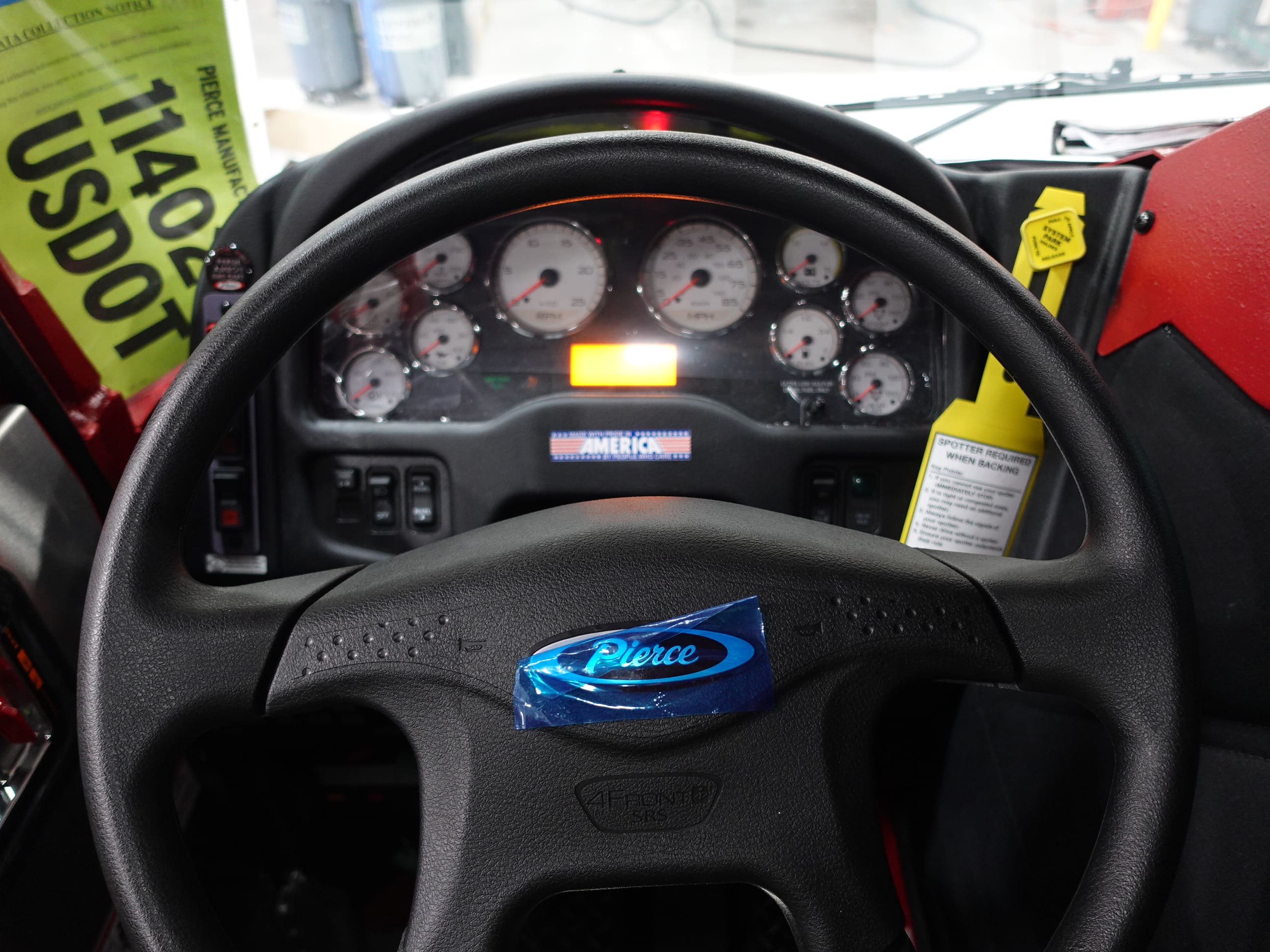

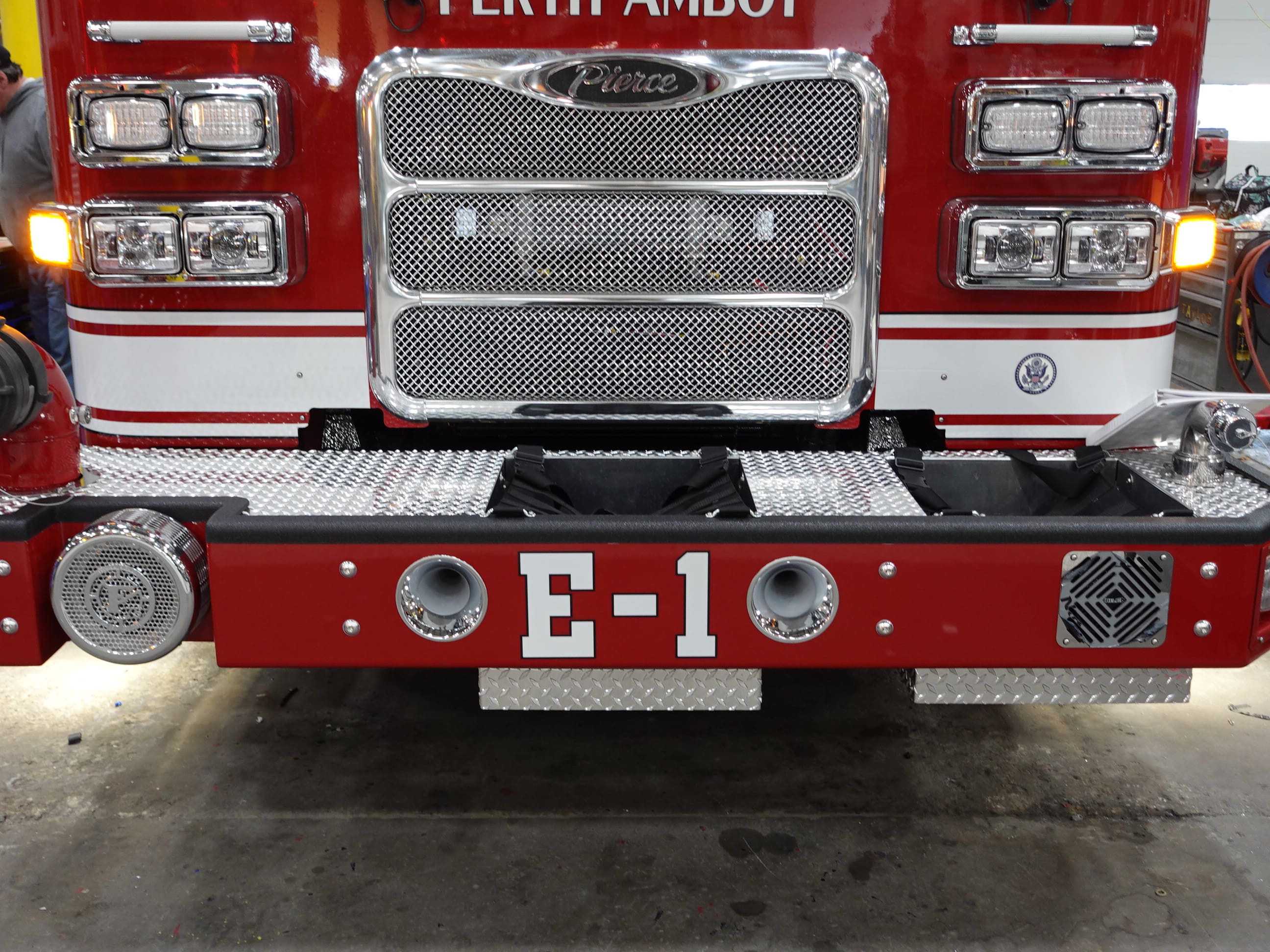

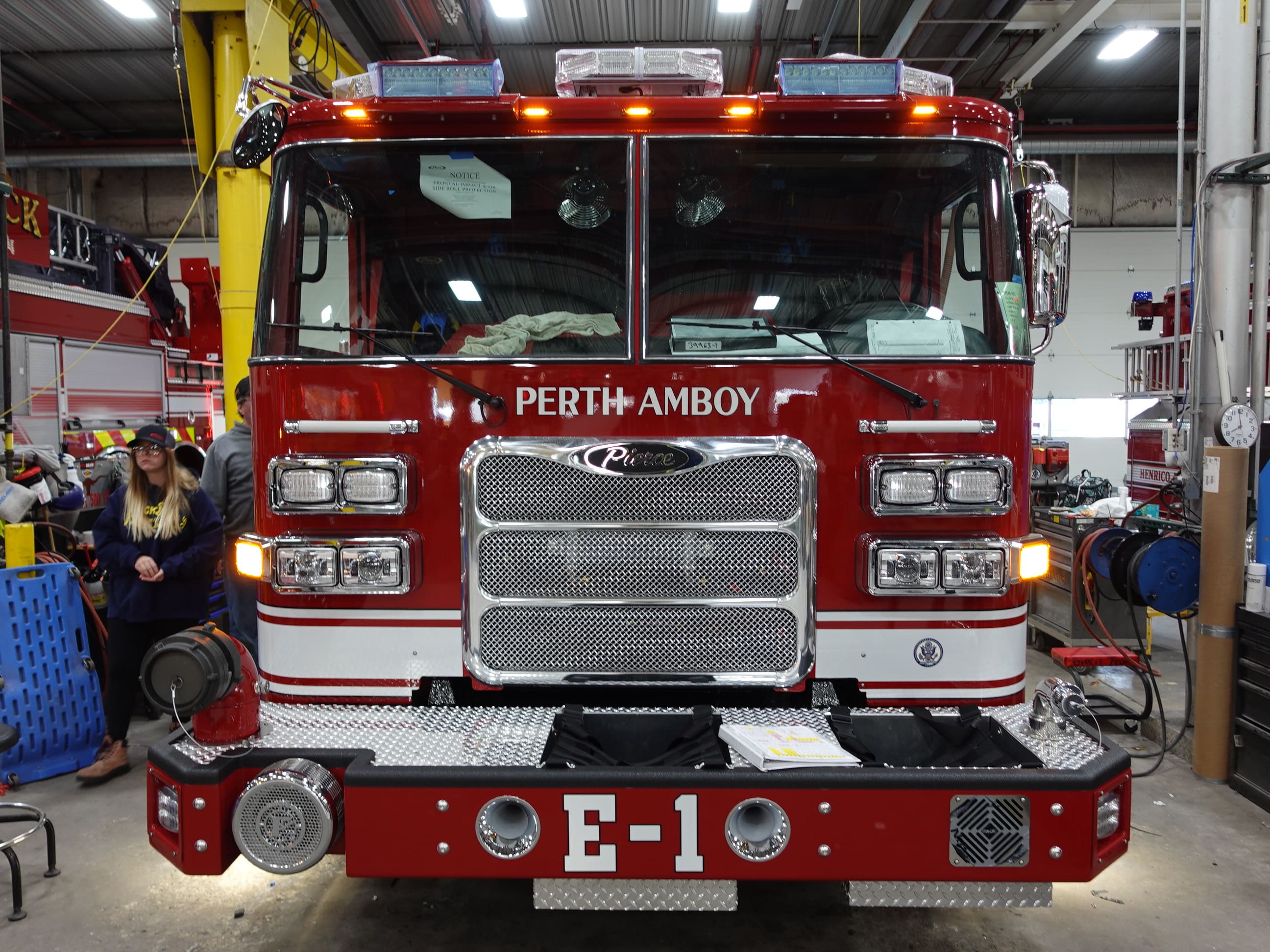

05-08-26

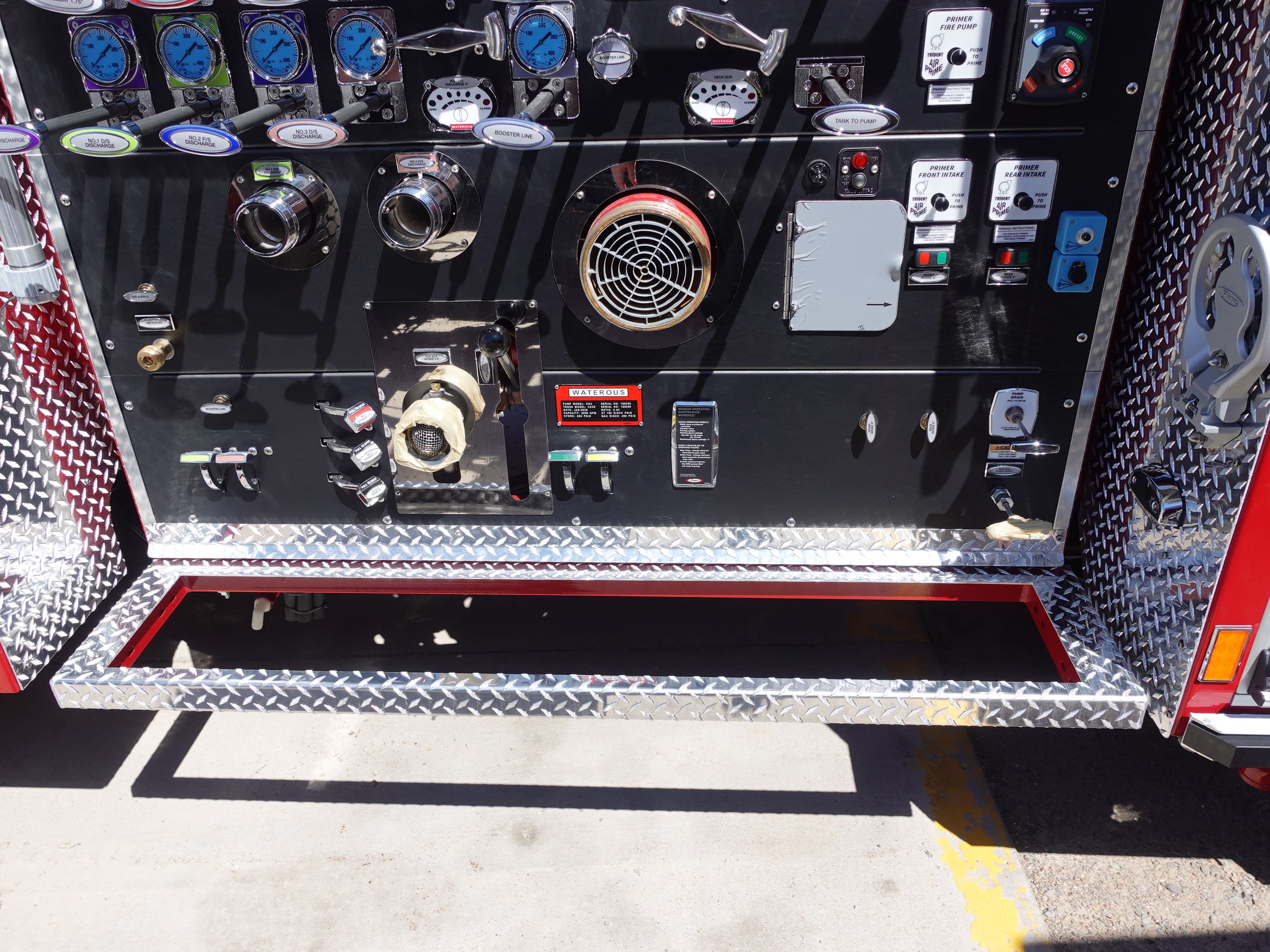

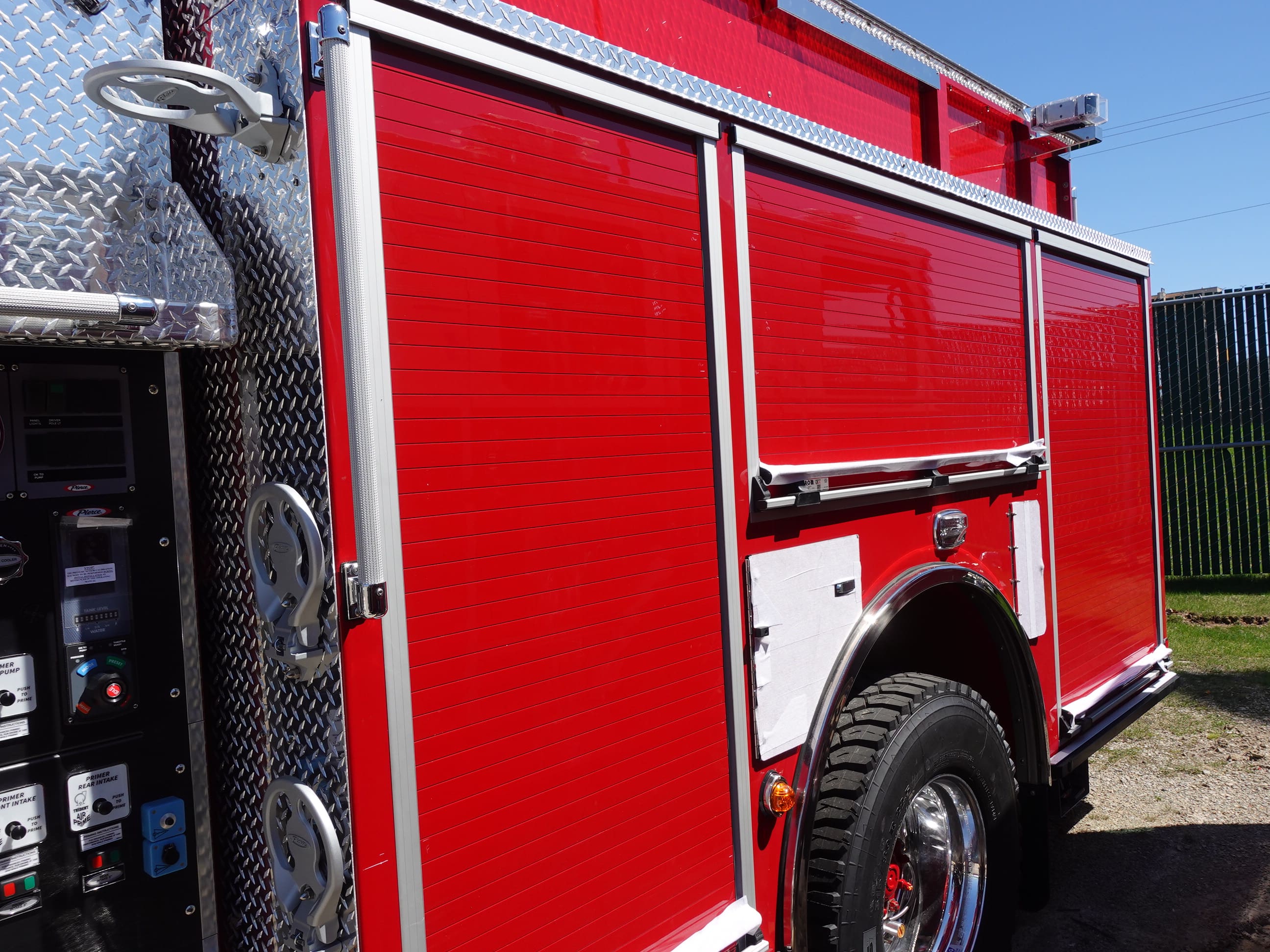

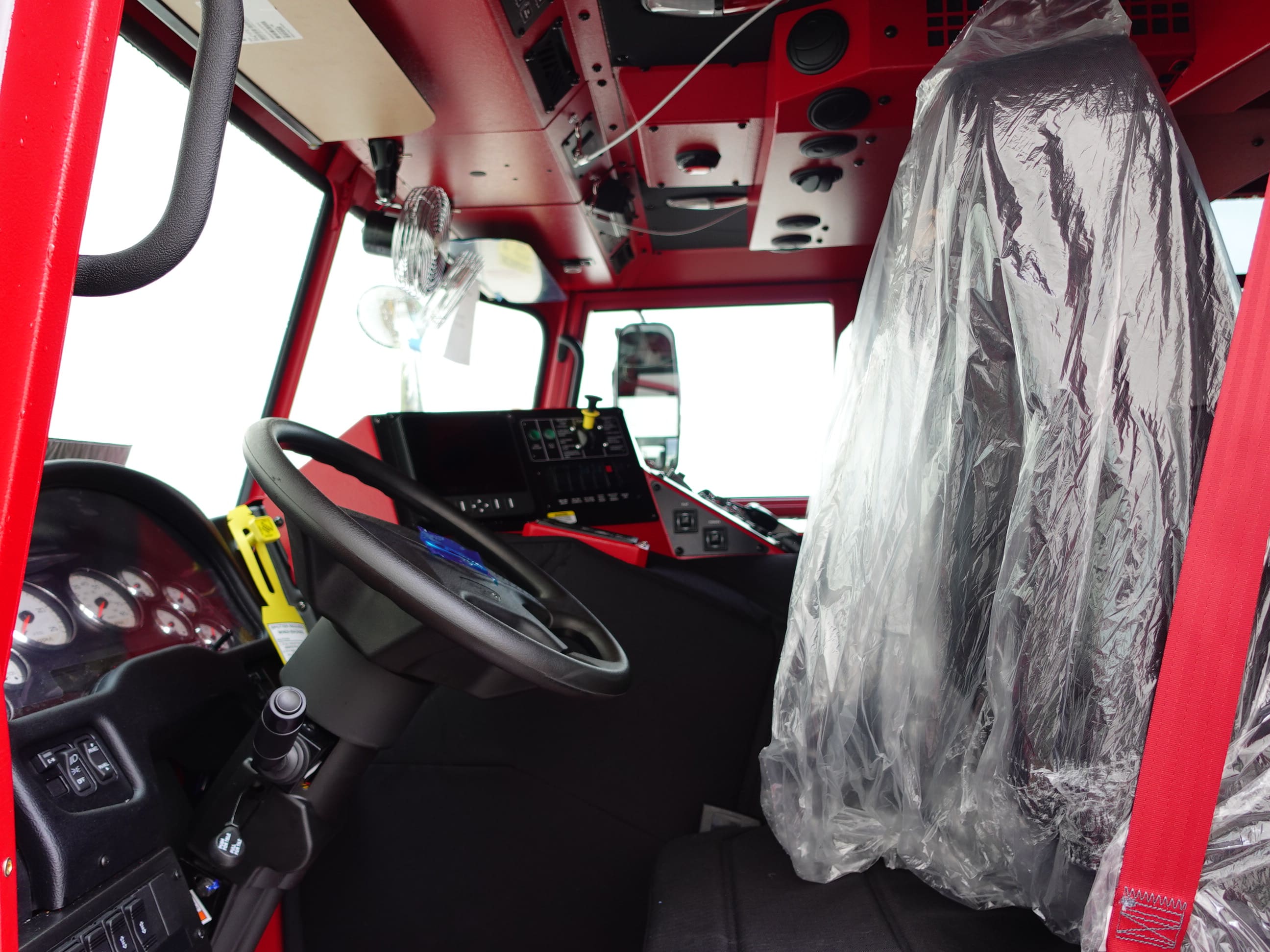

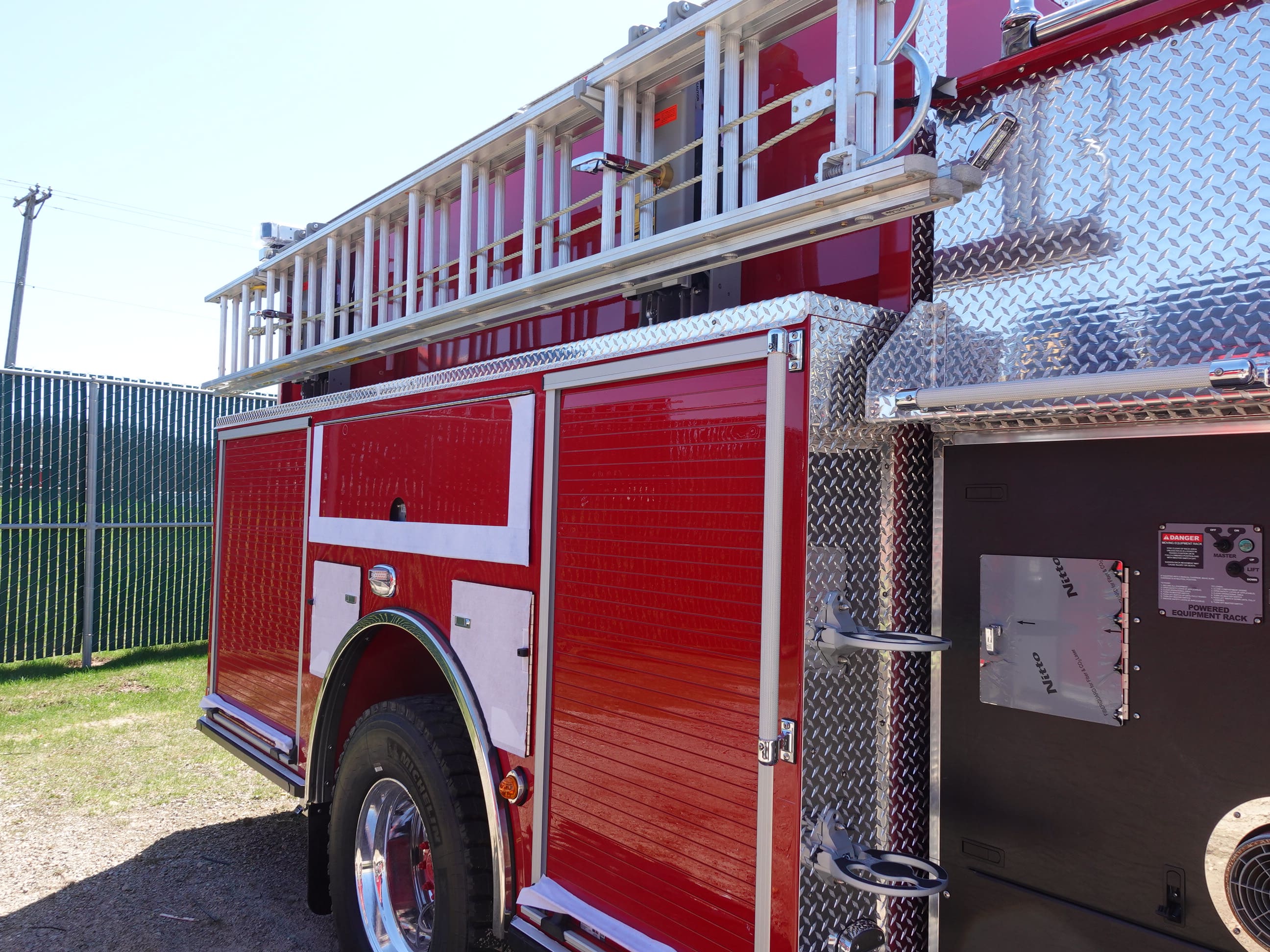

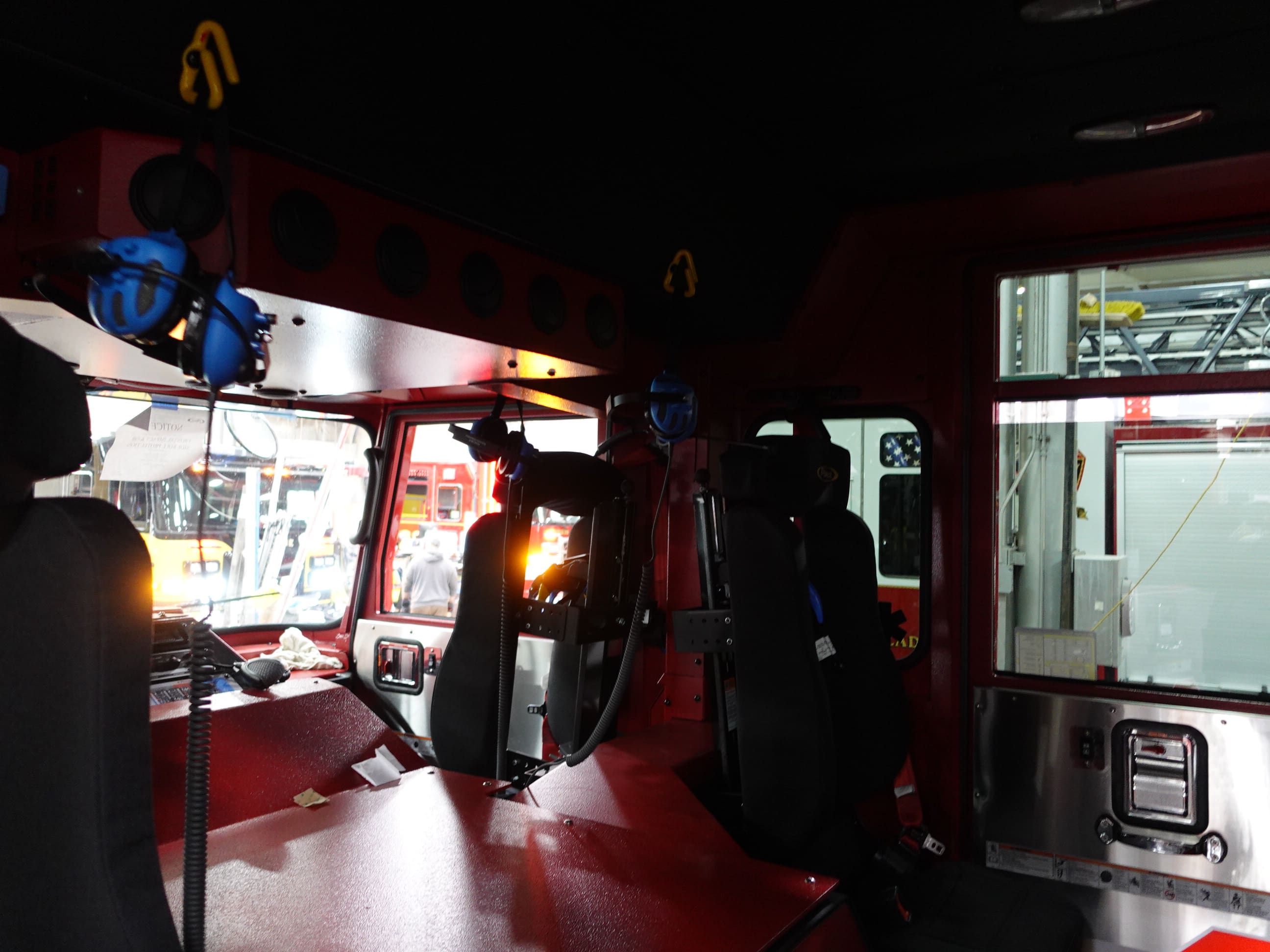

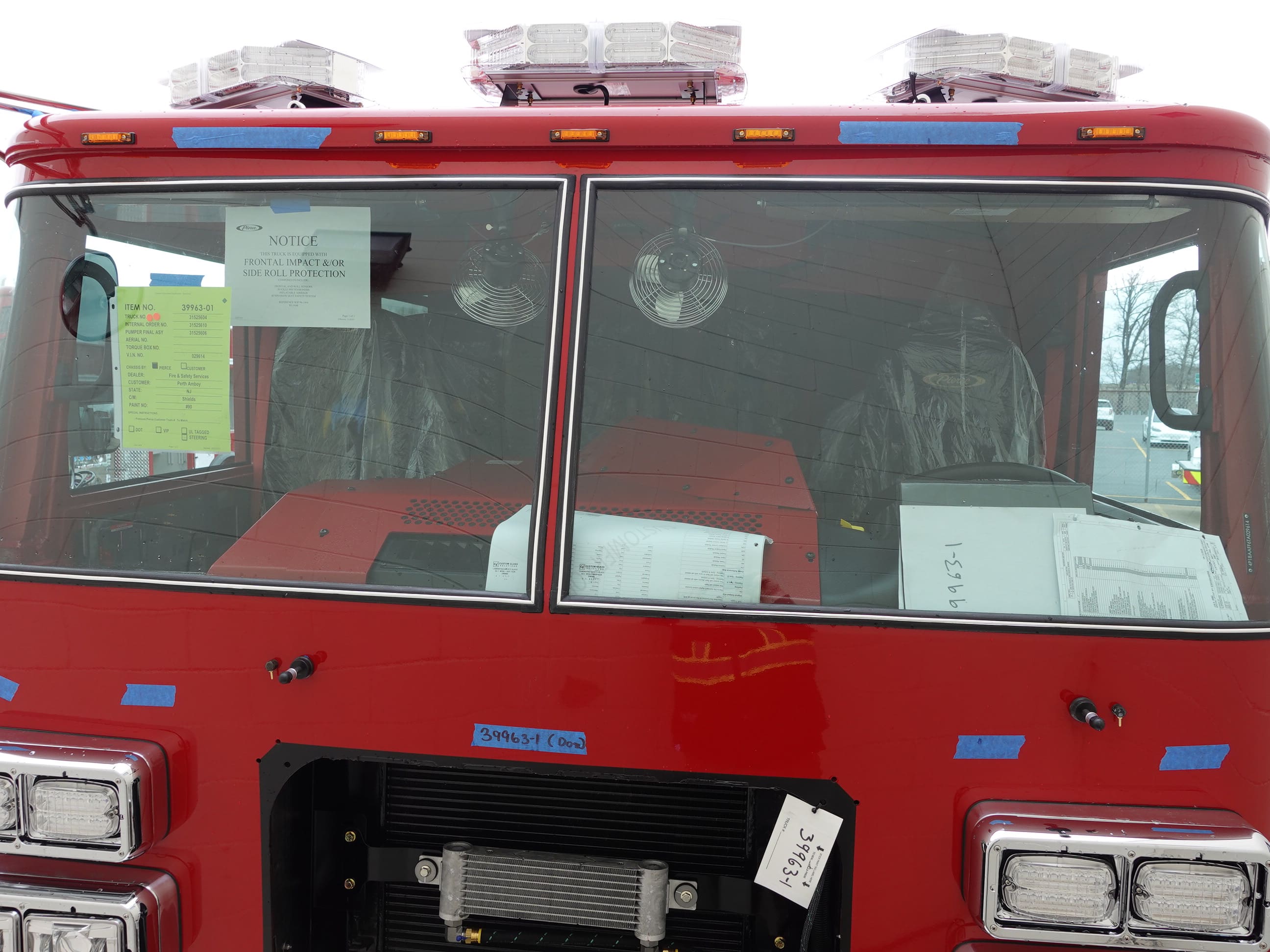

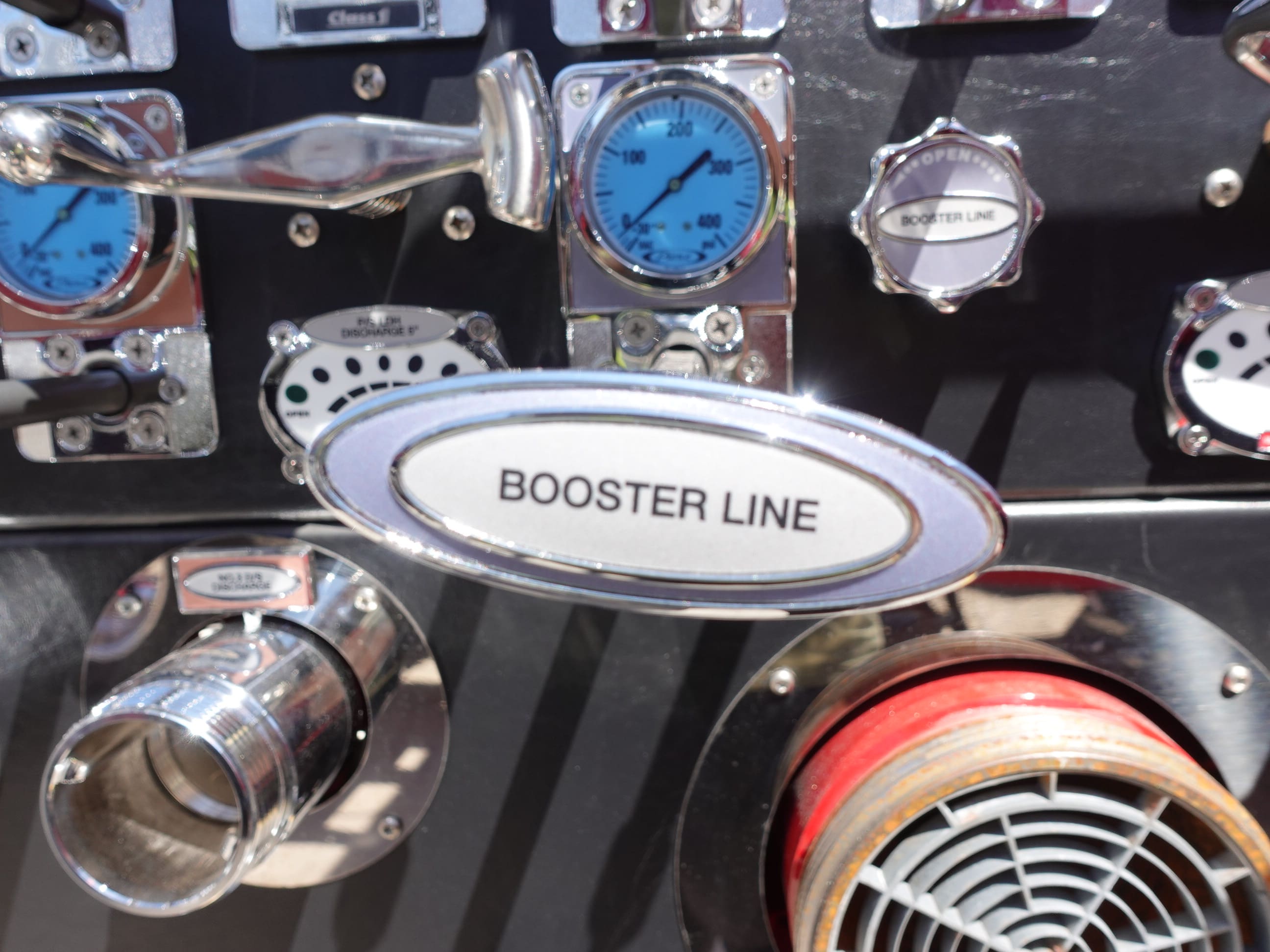

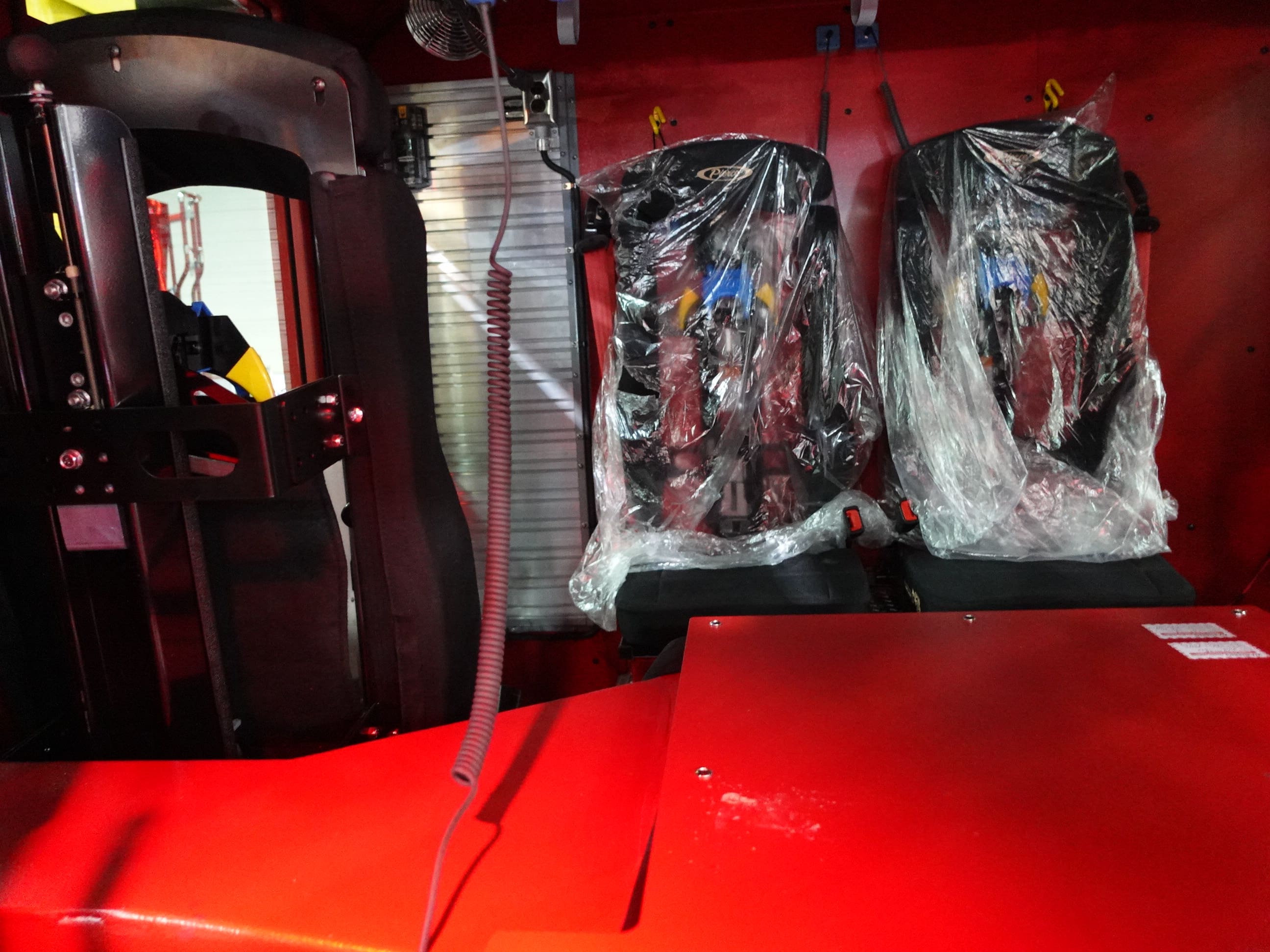

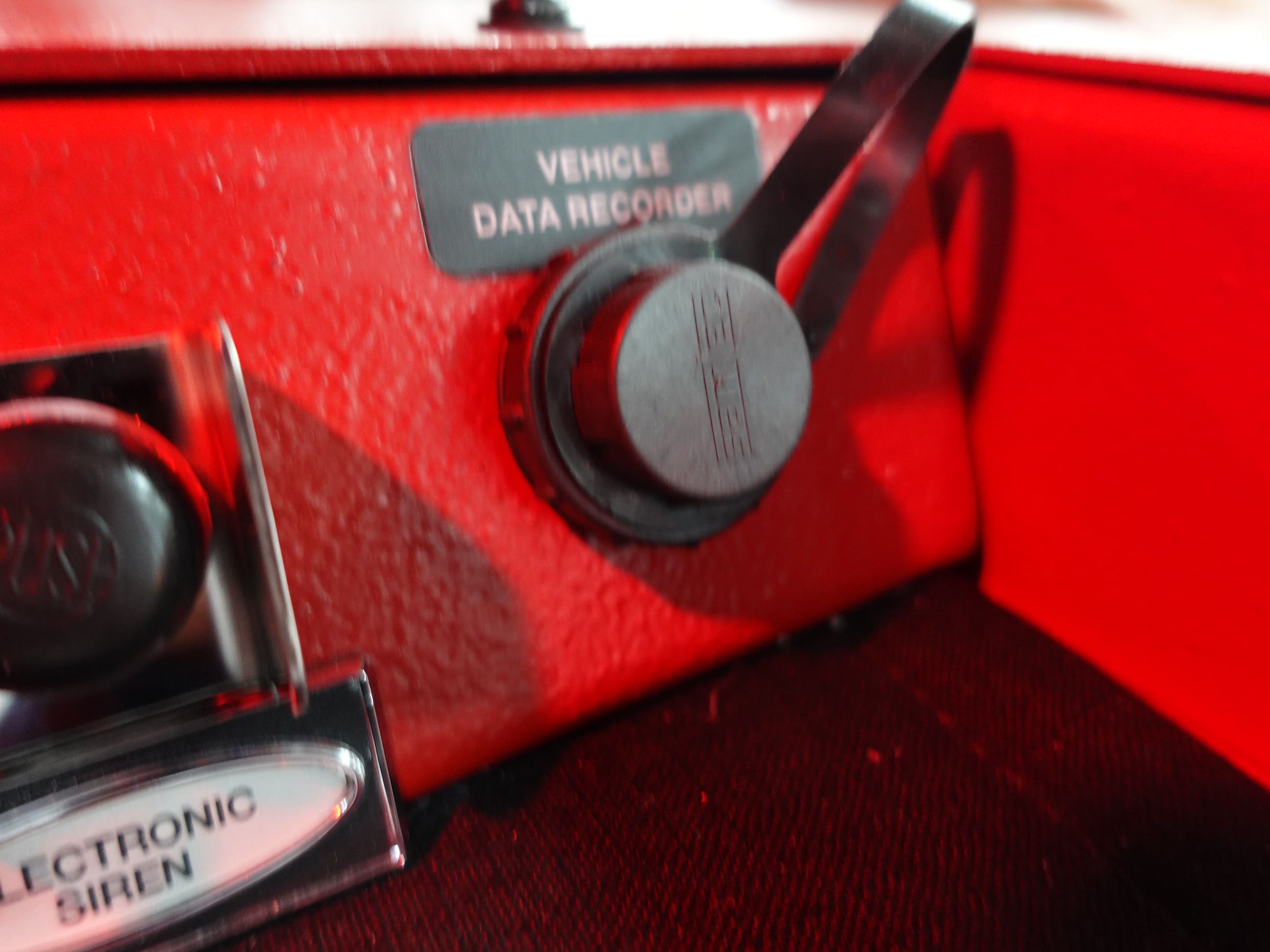

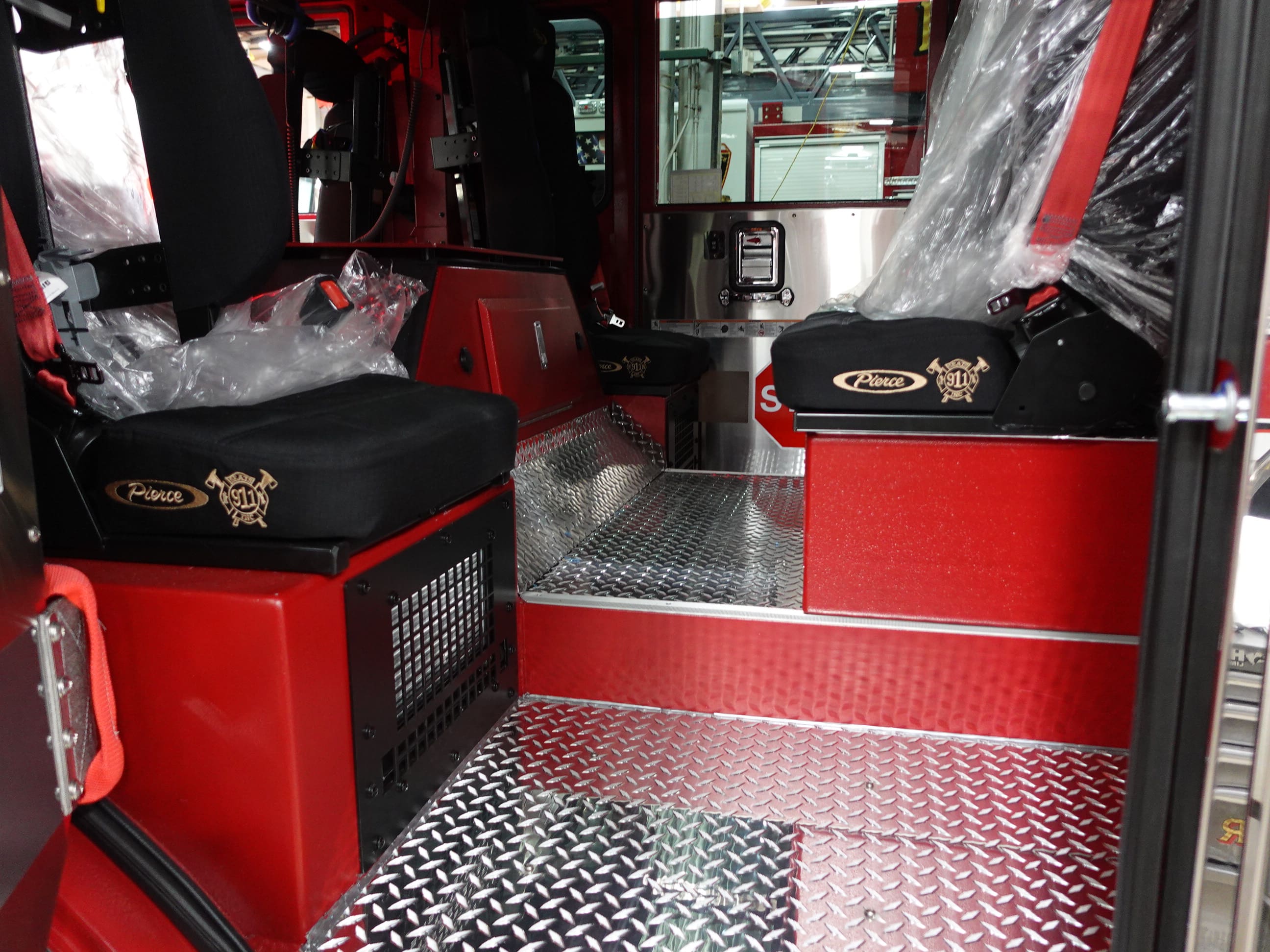

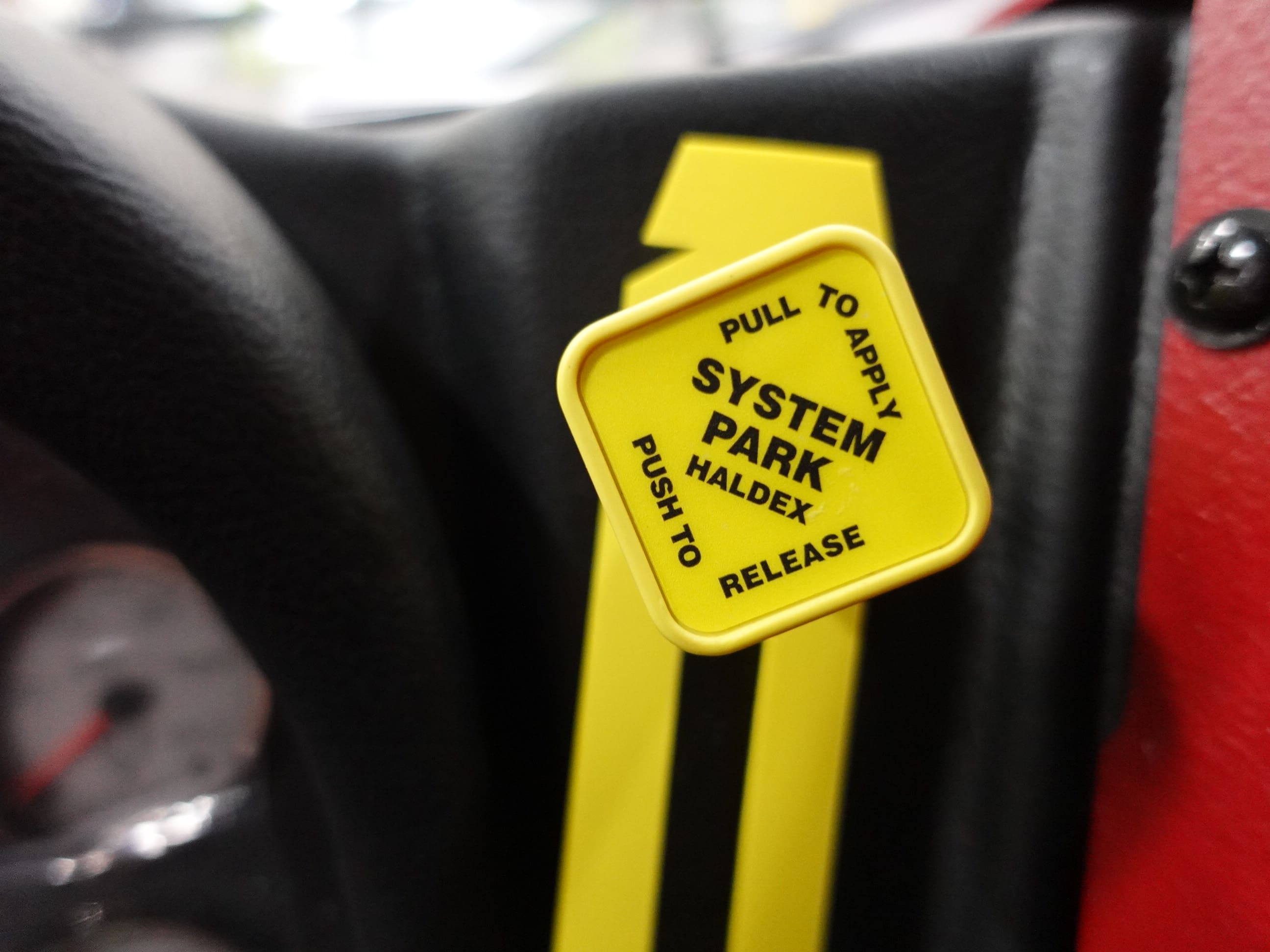

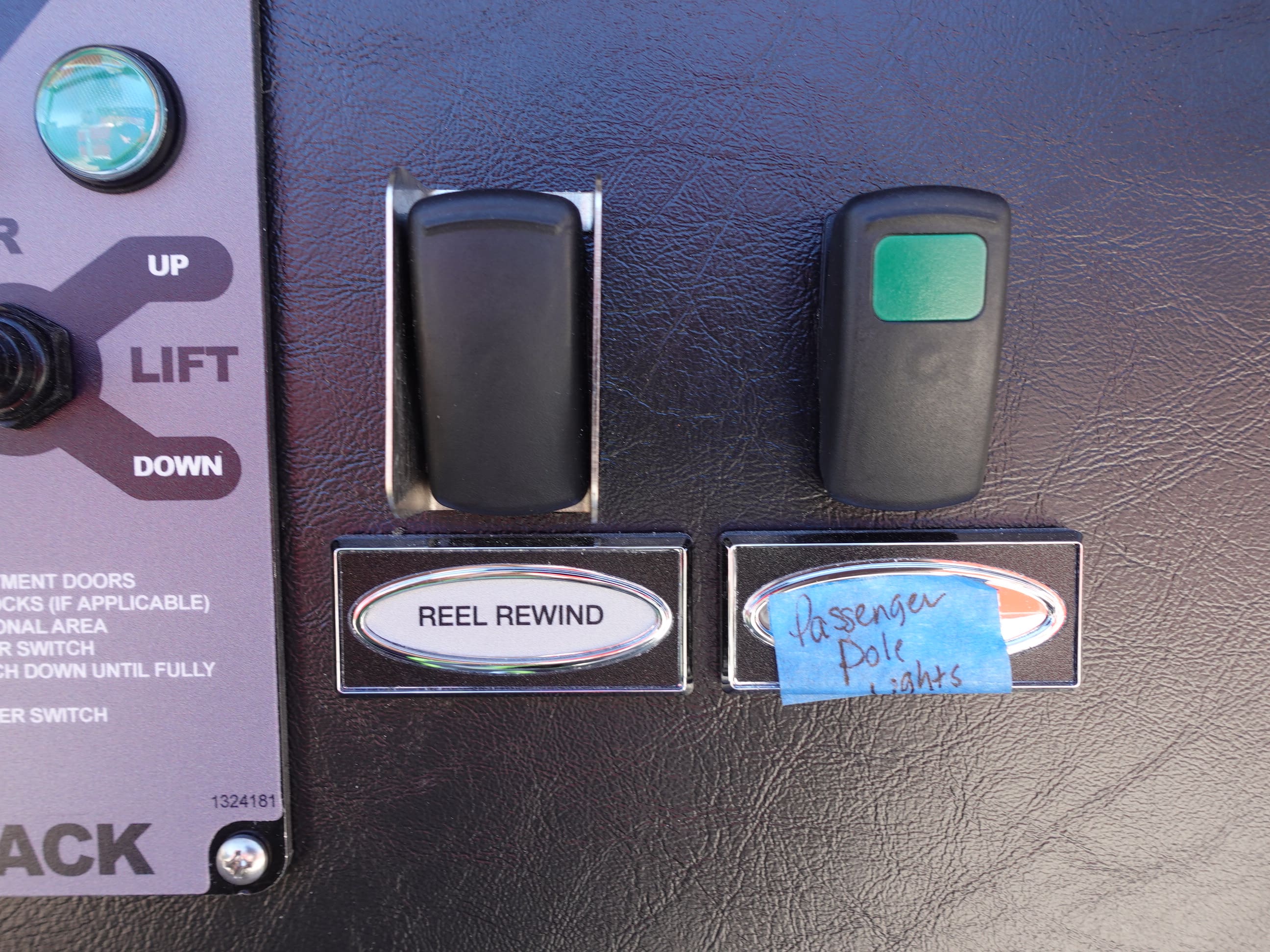

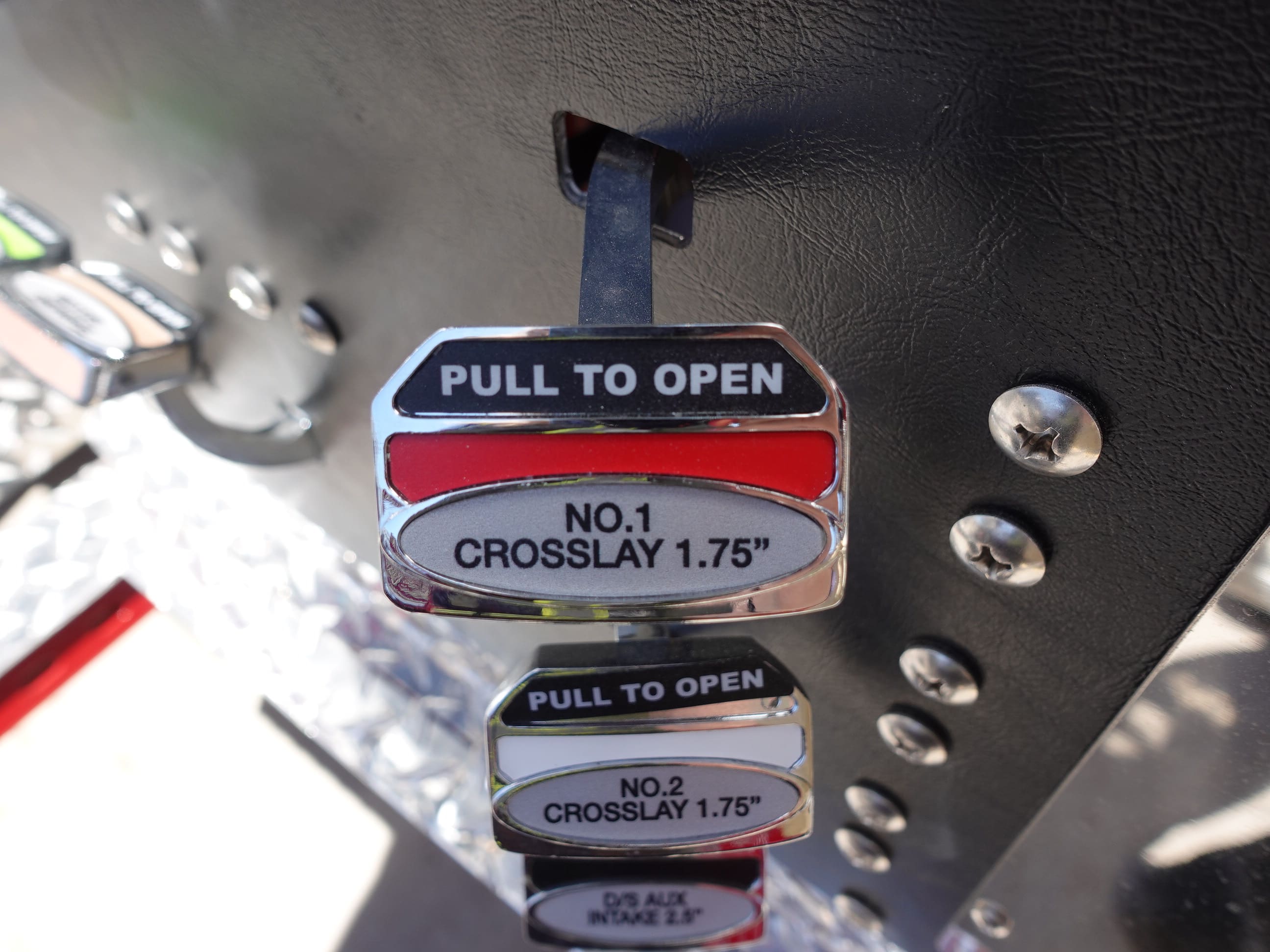

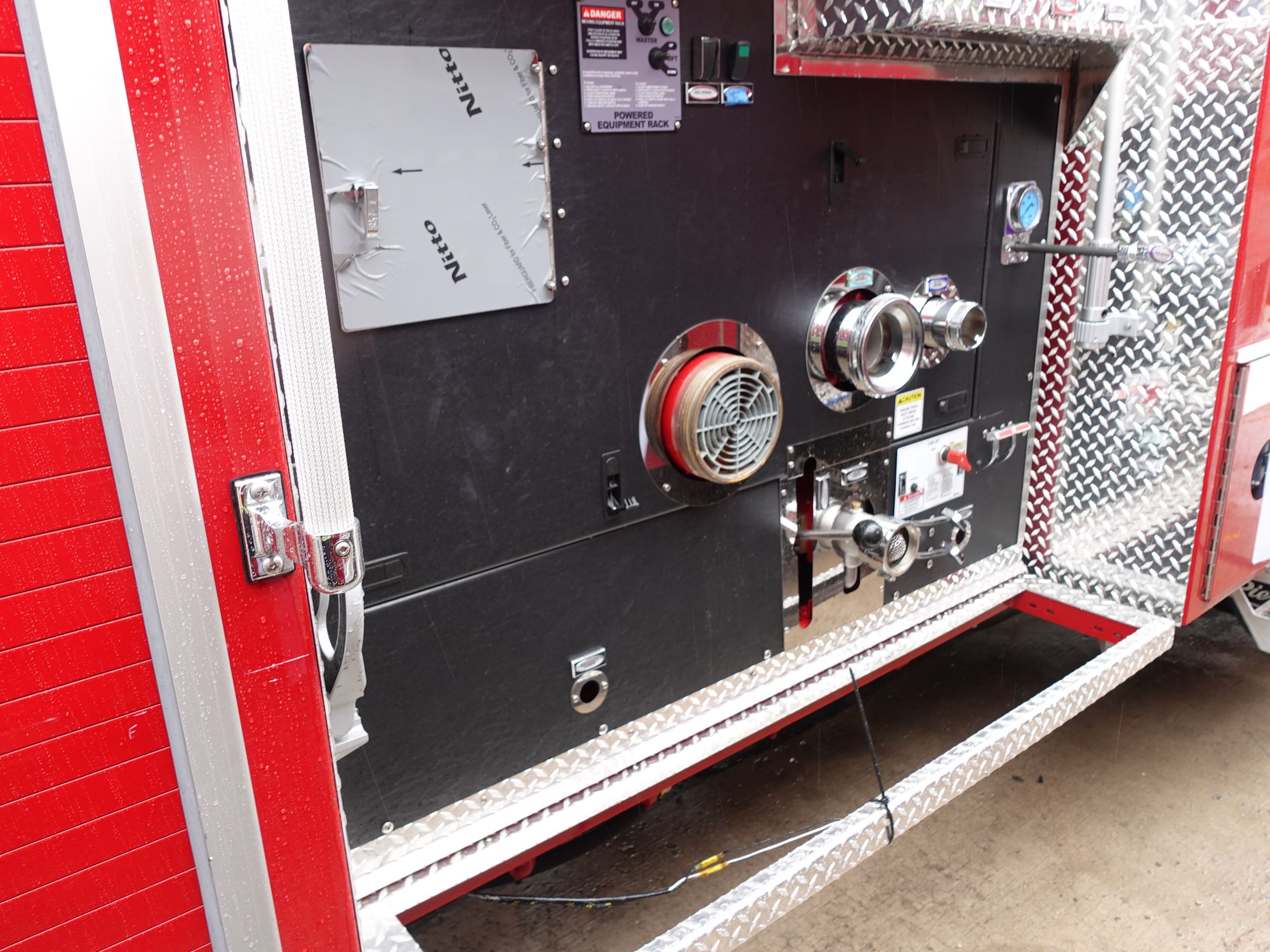

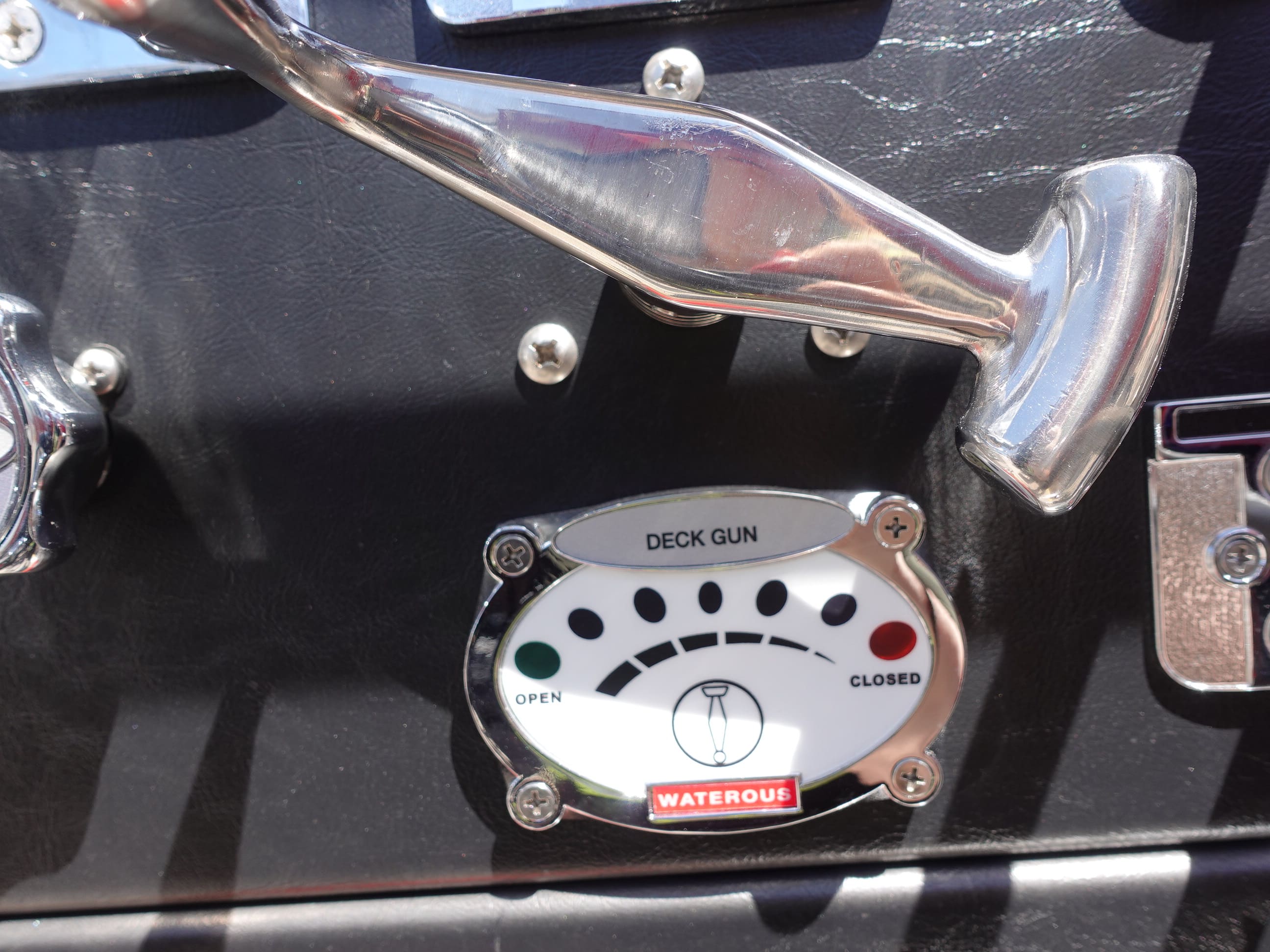

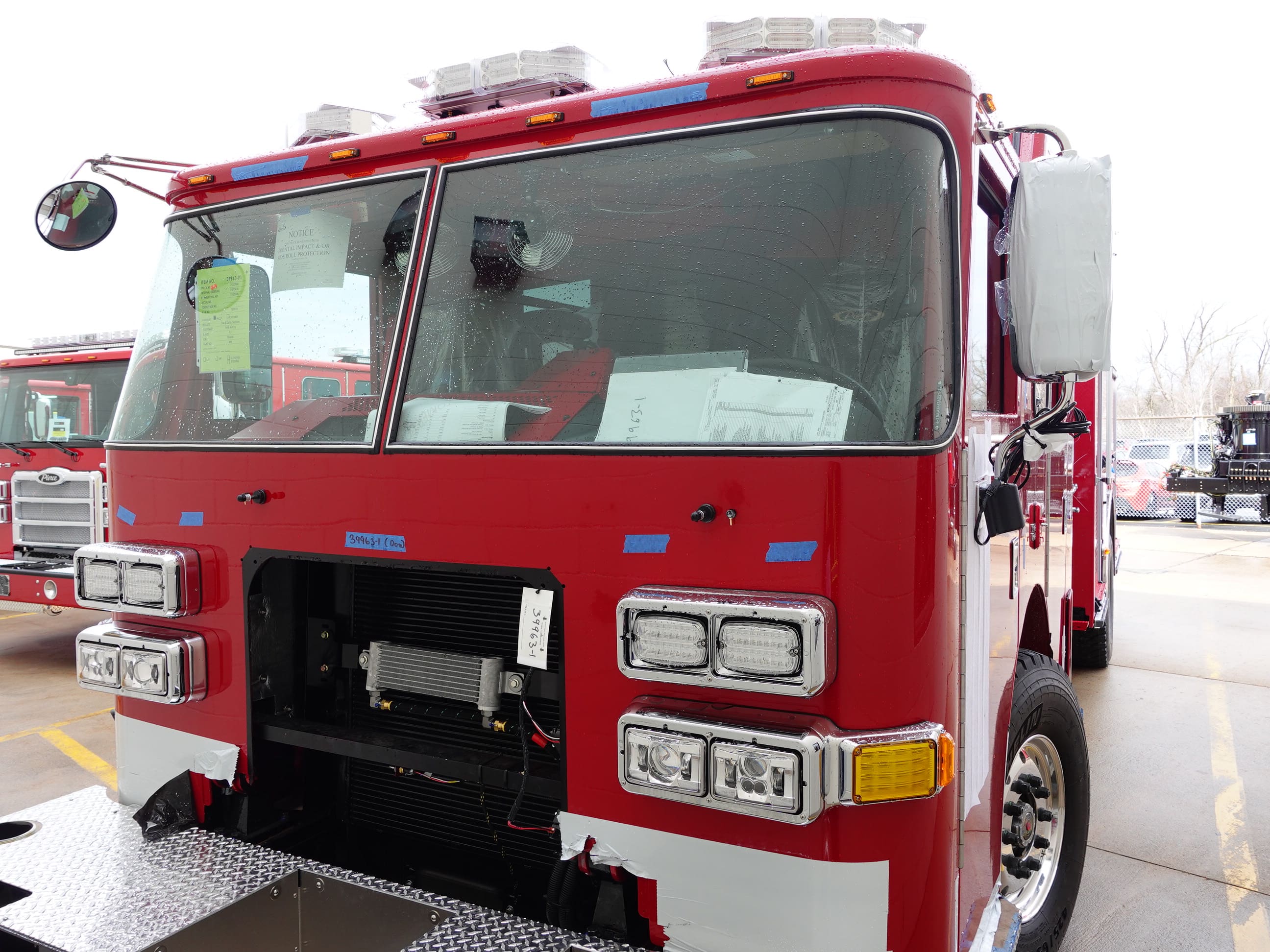

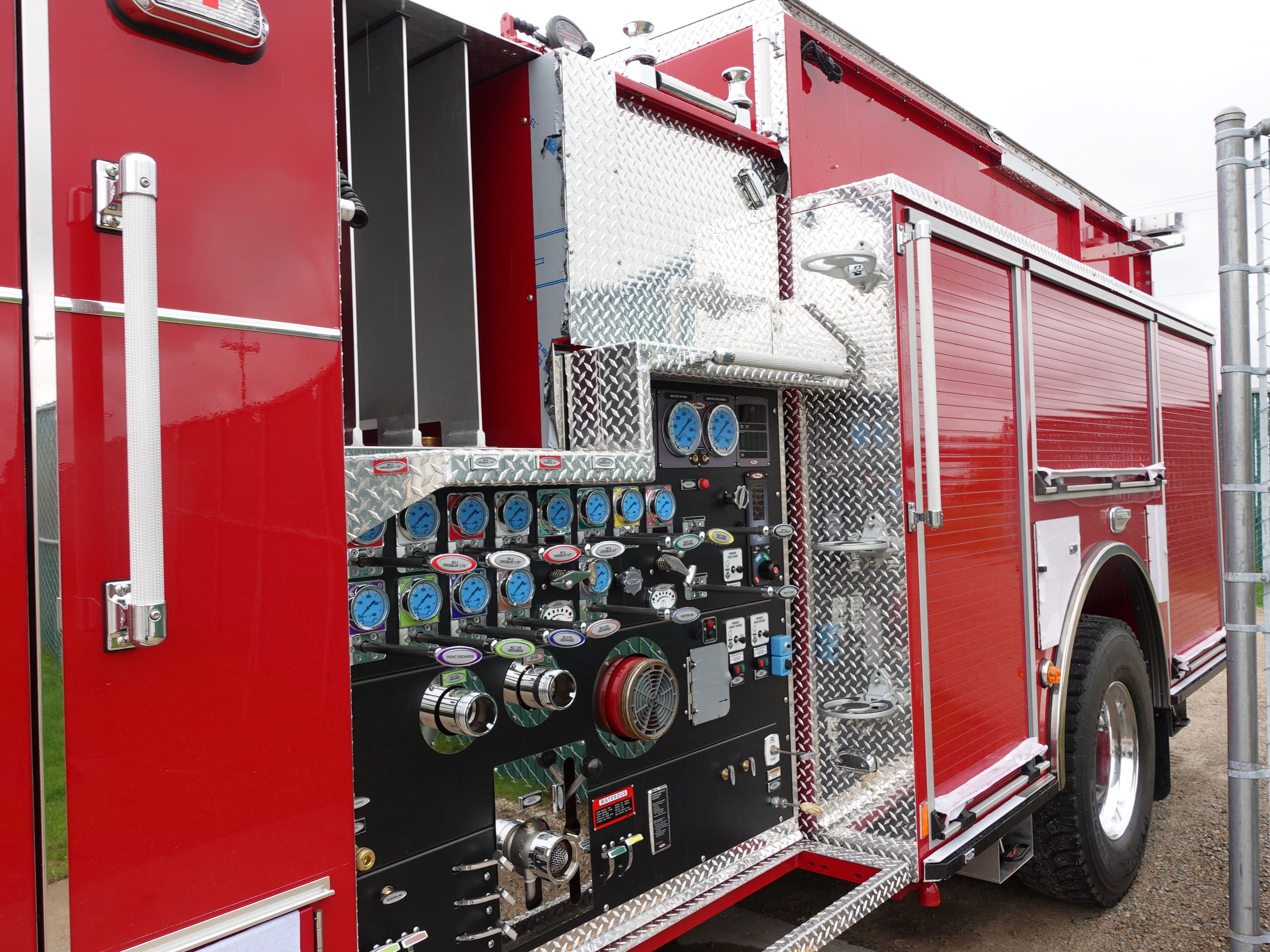

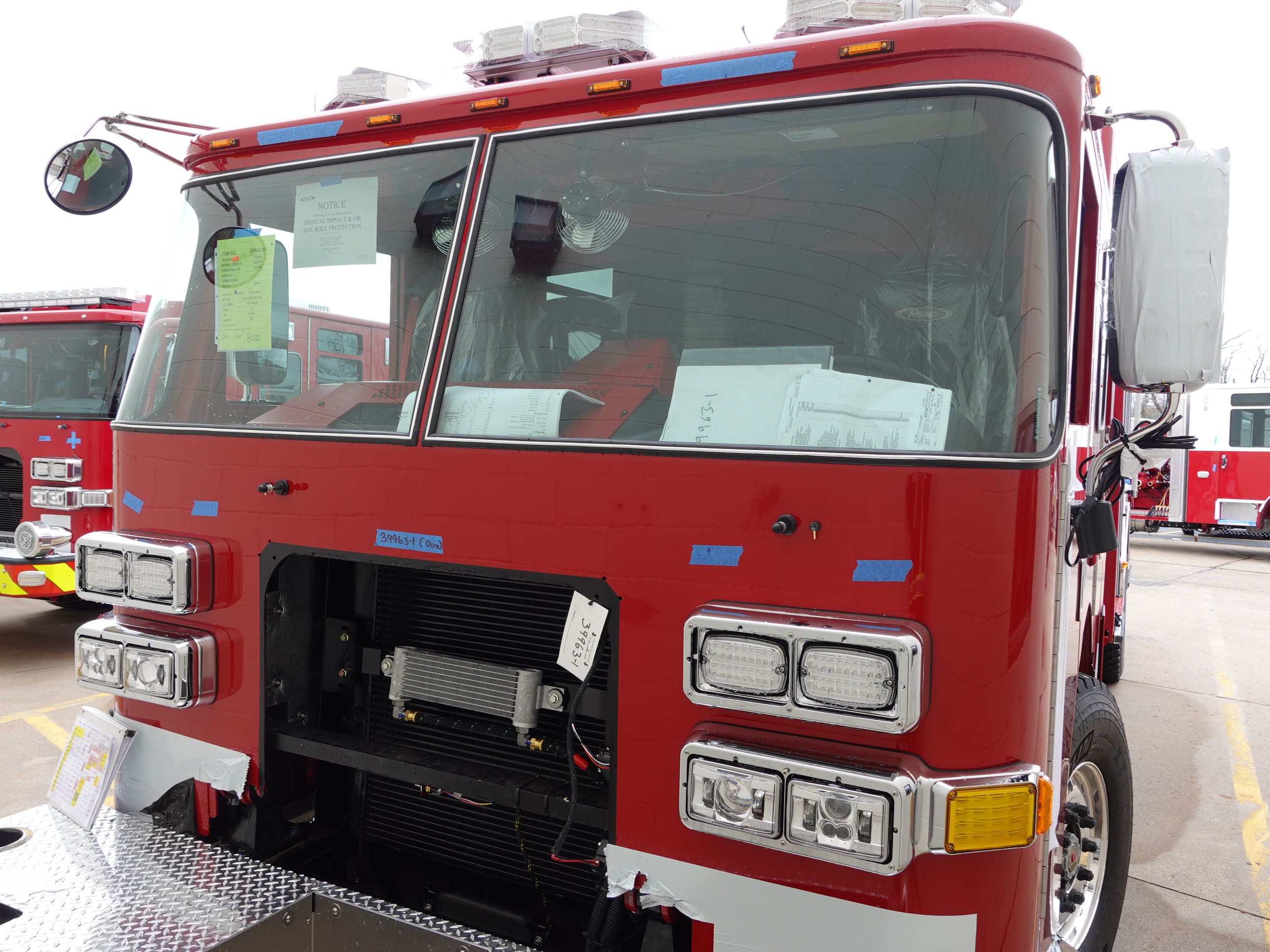

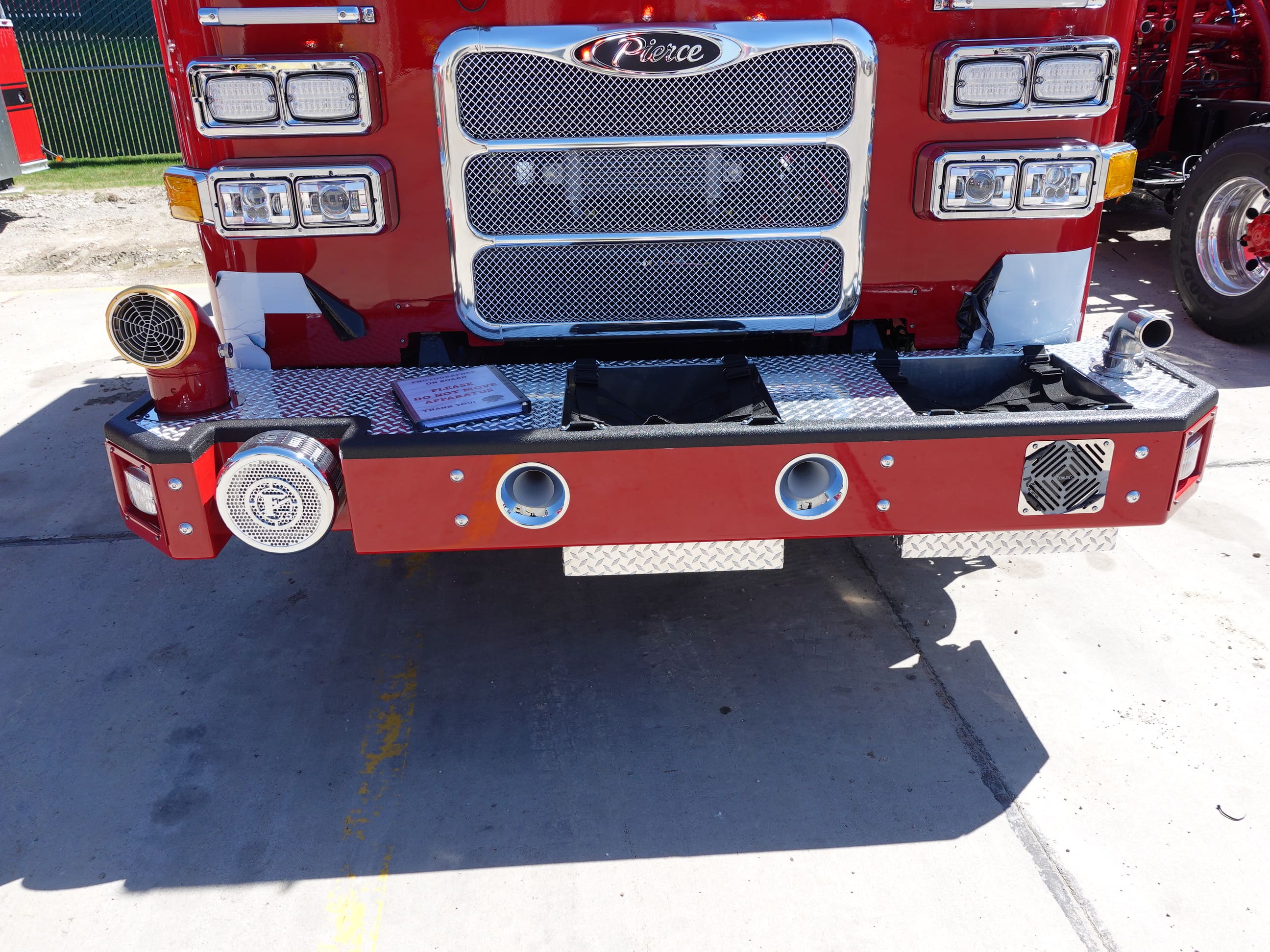

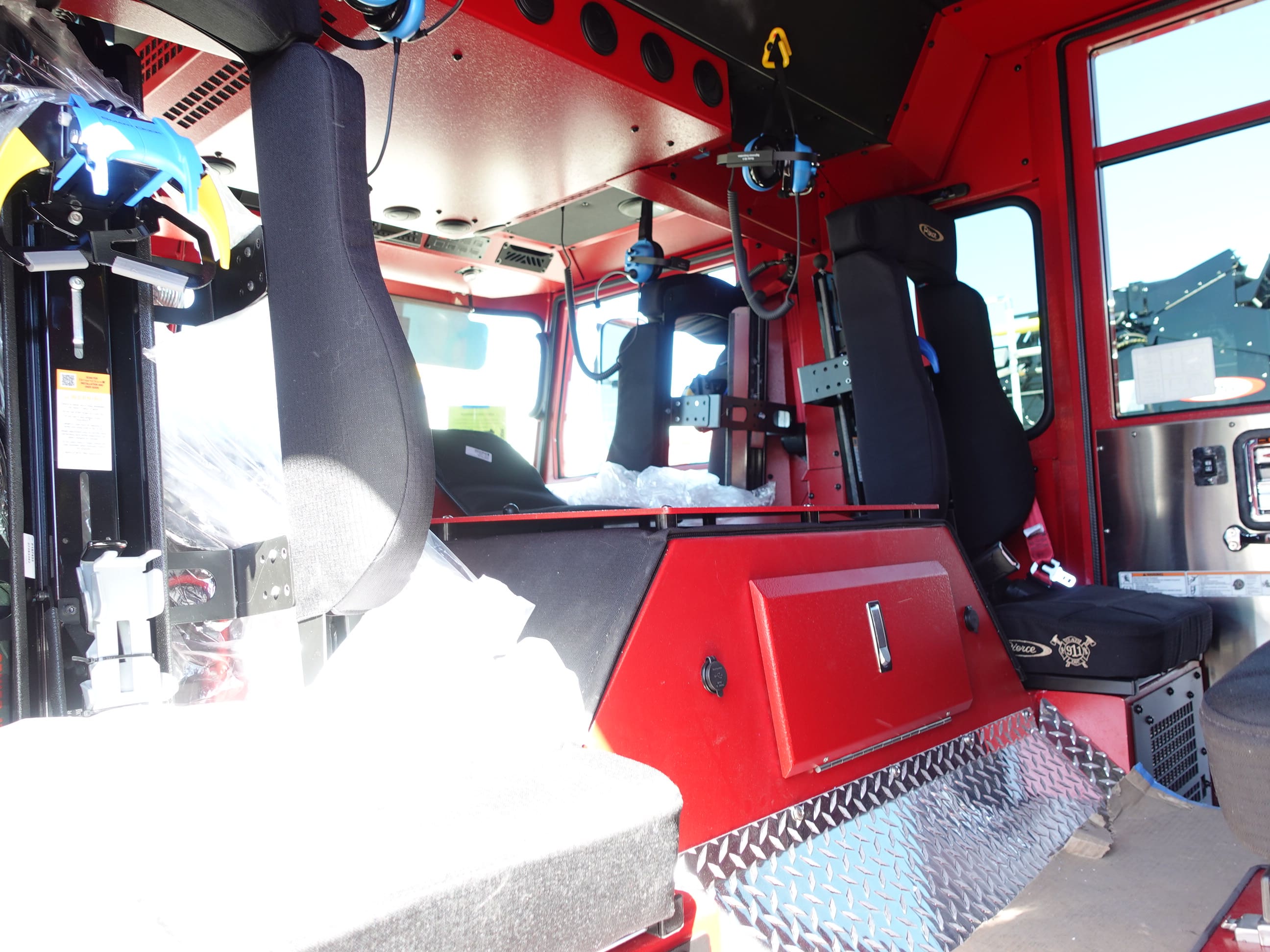

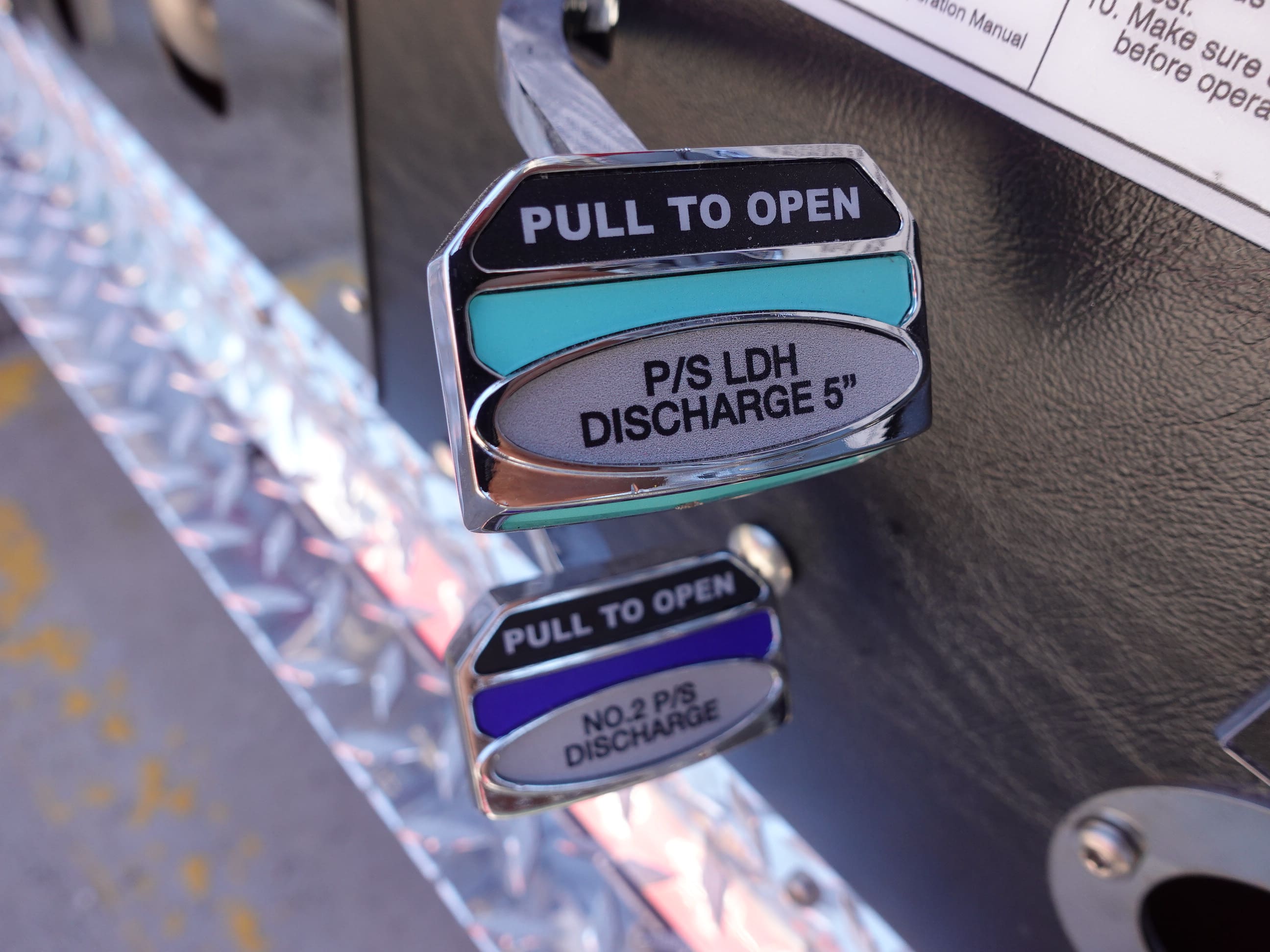

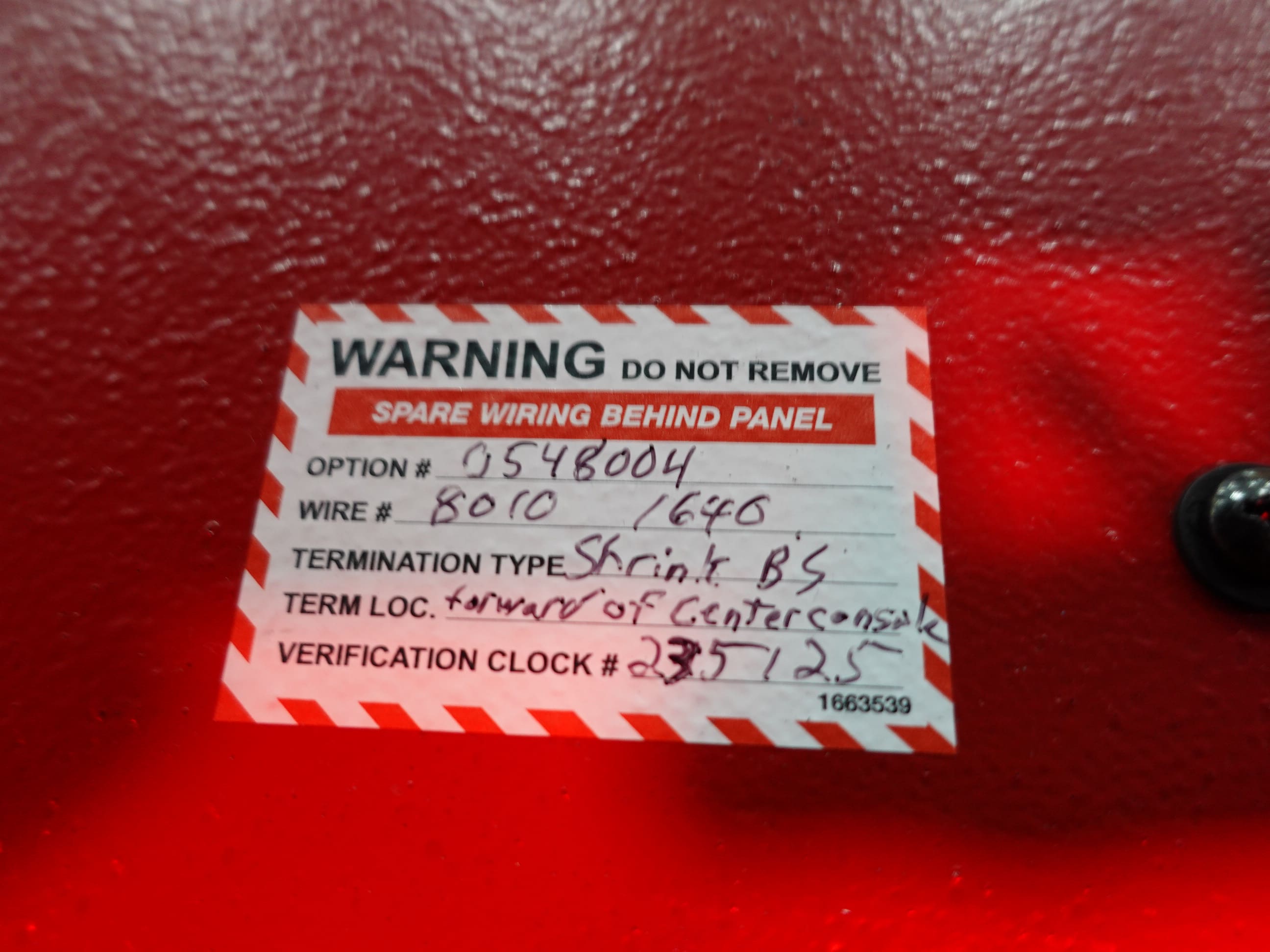

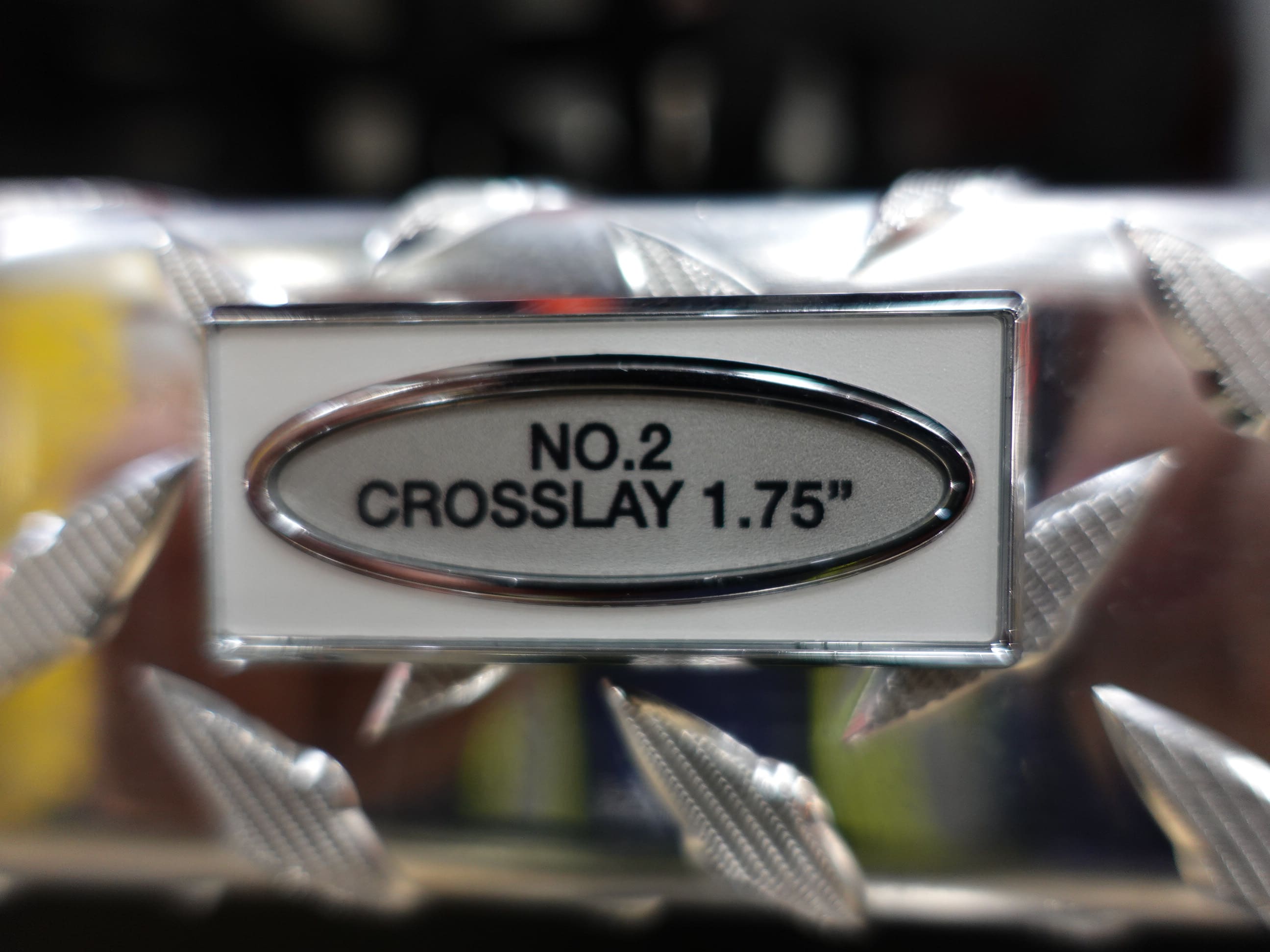

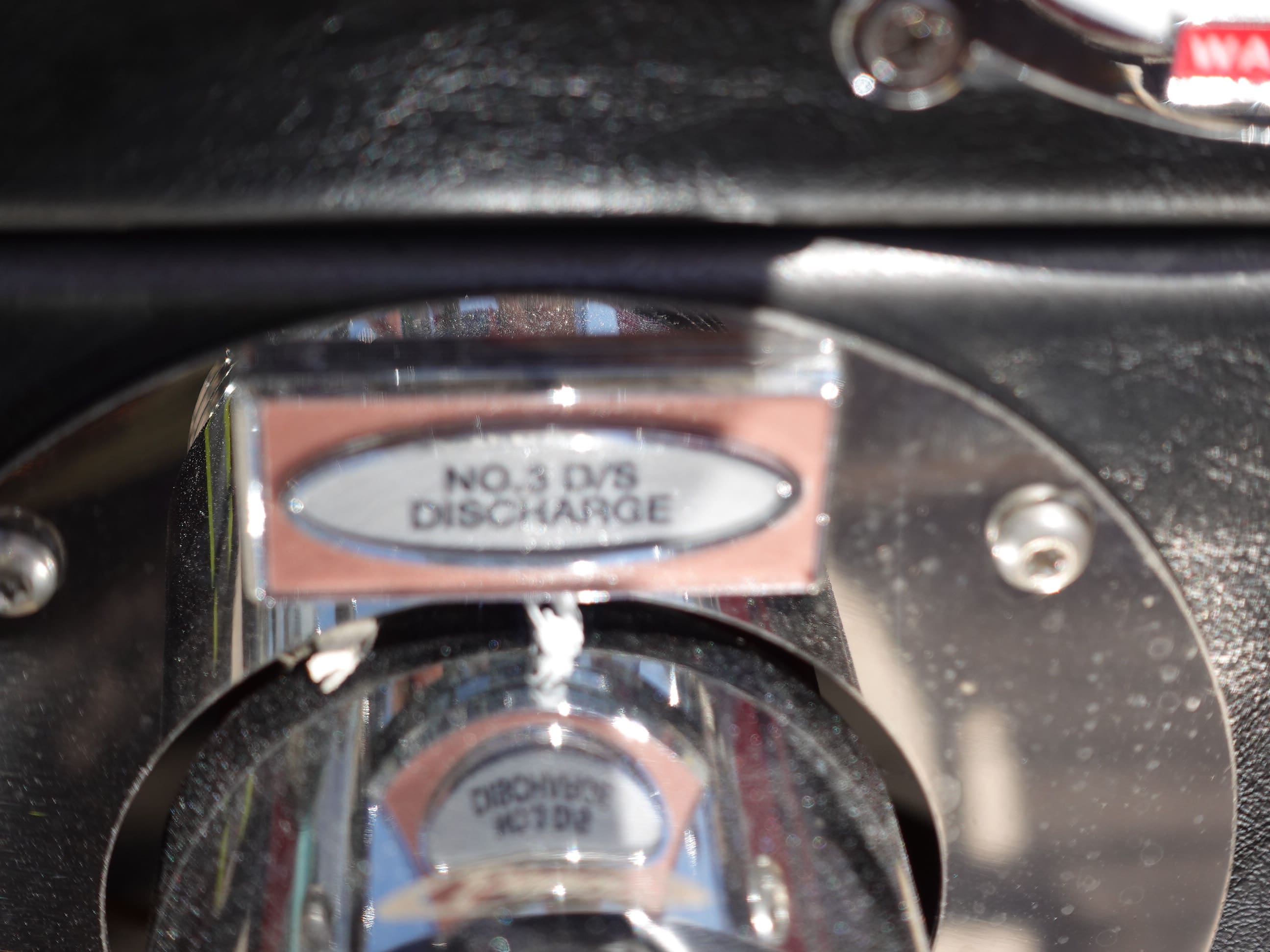

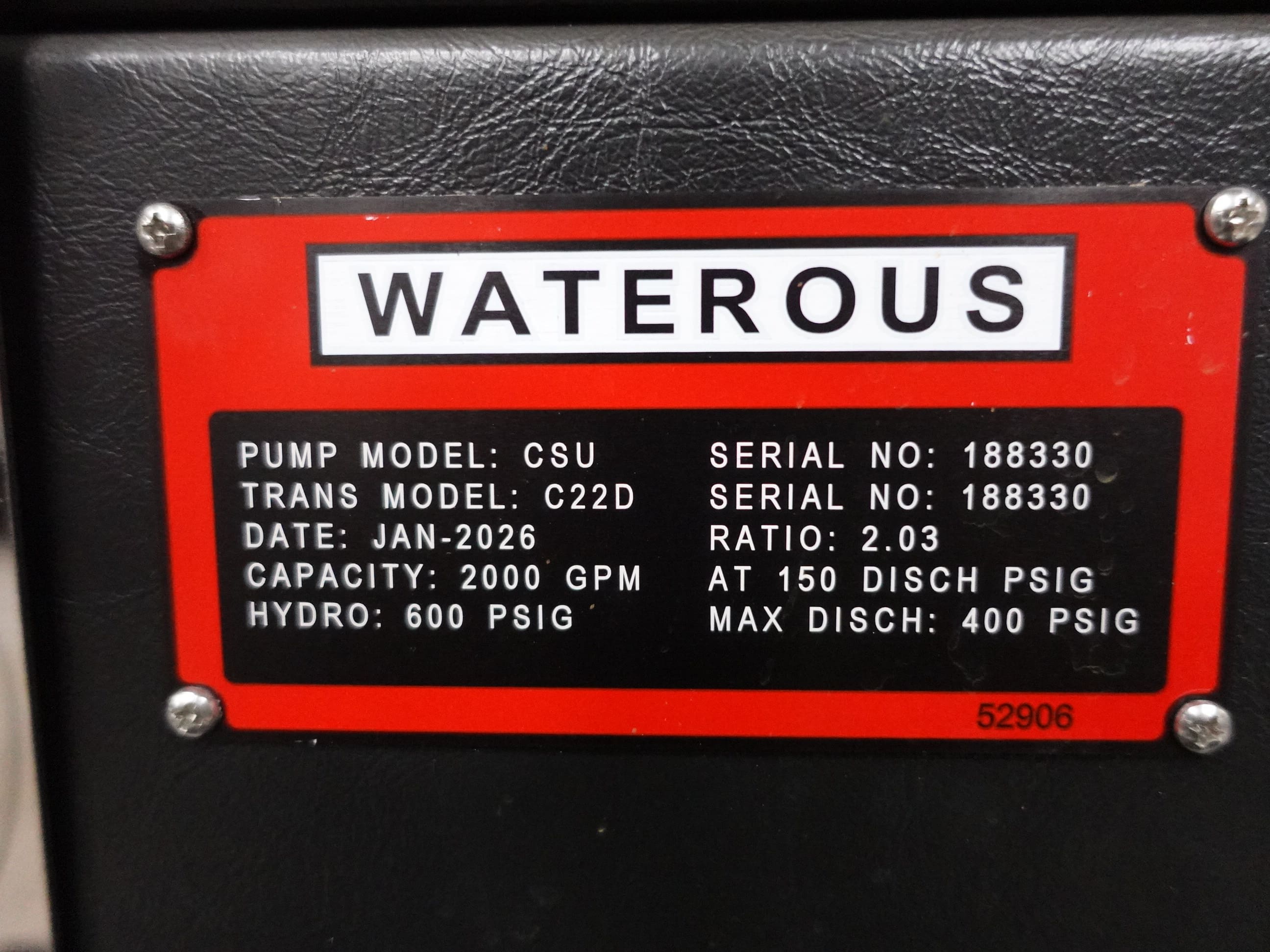

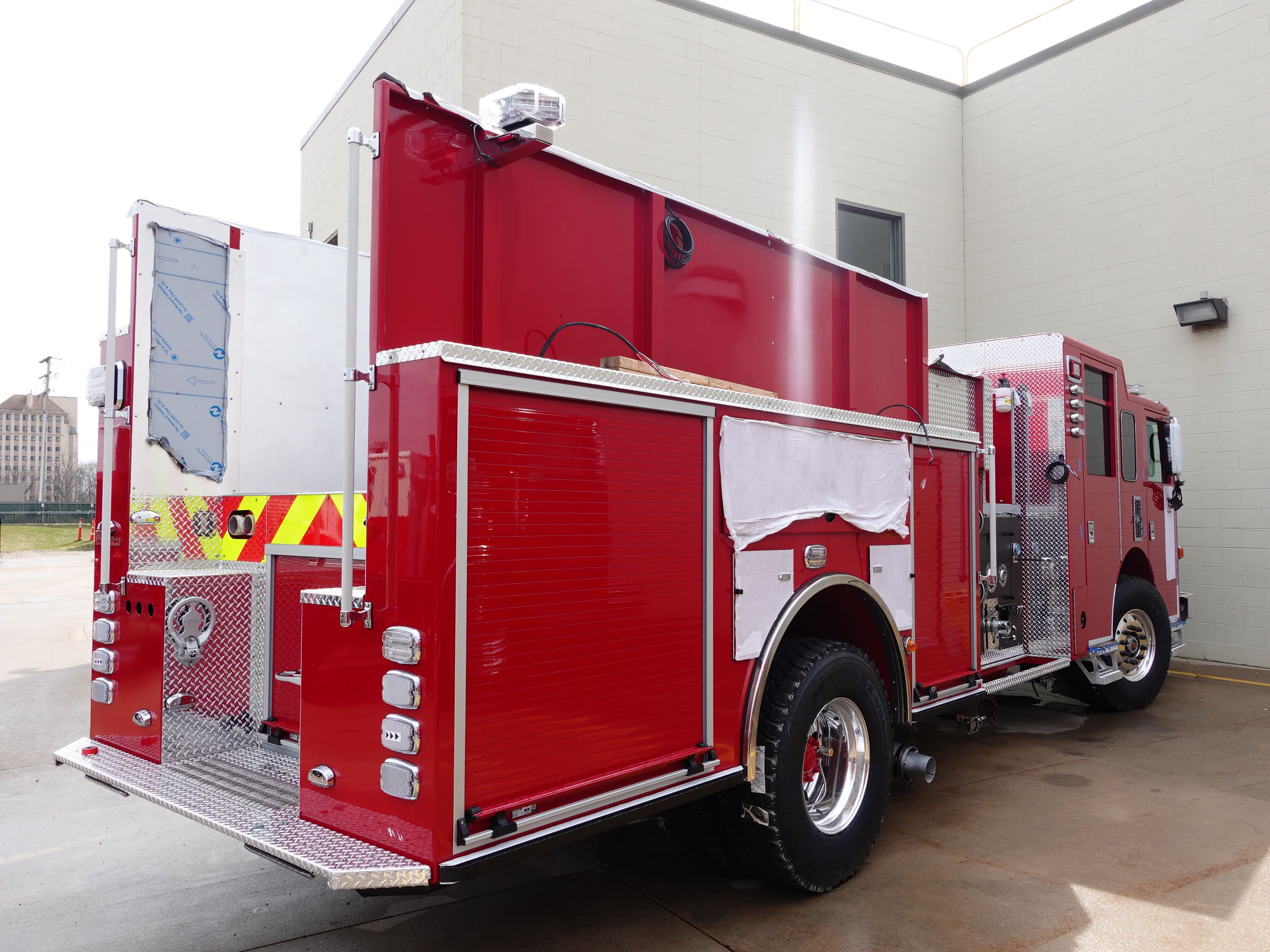

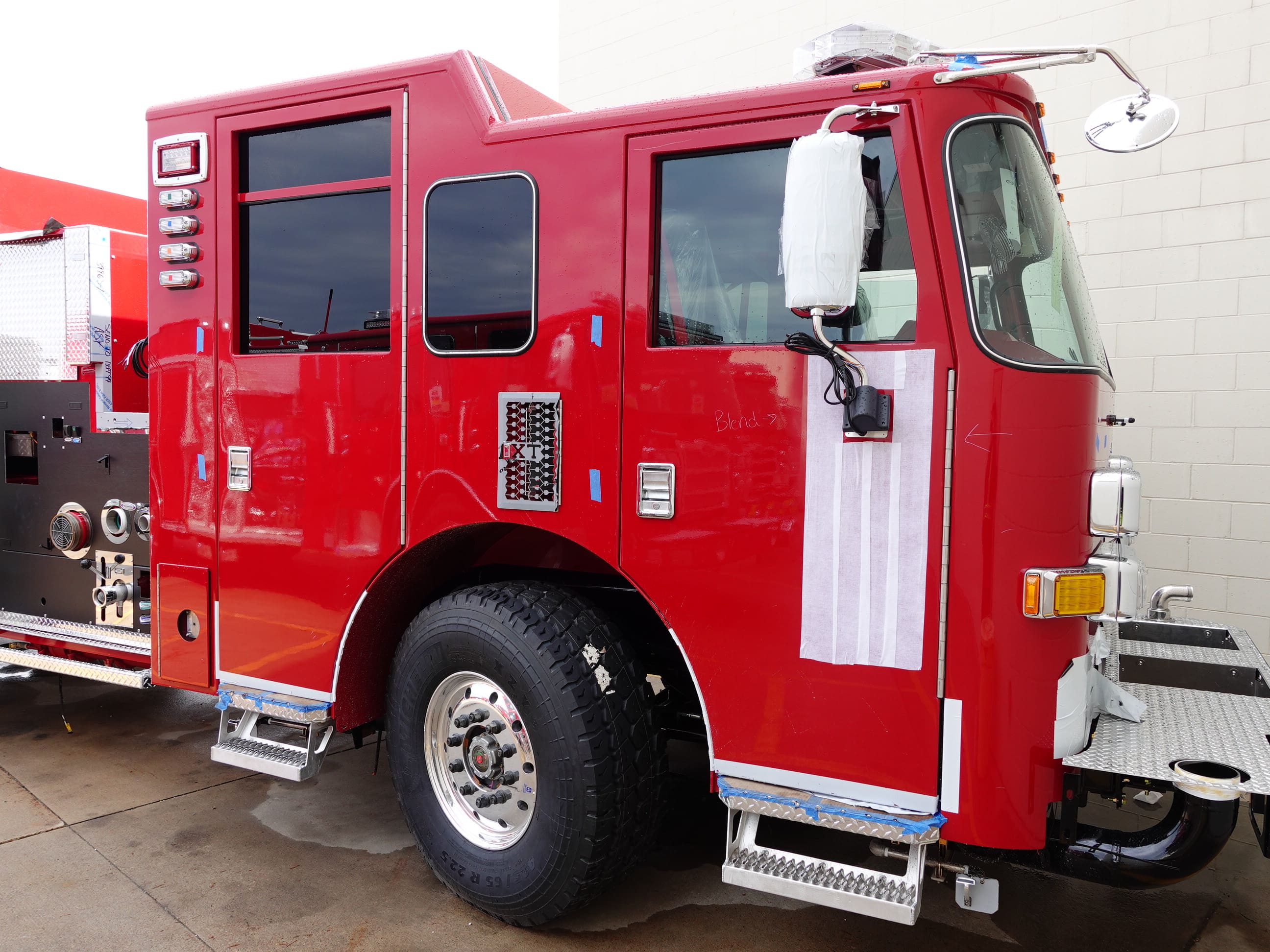

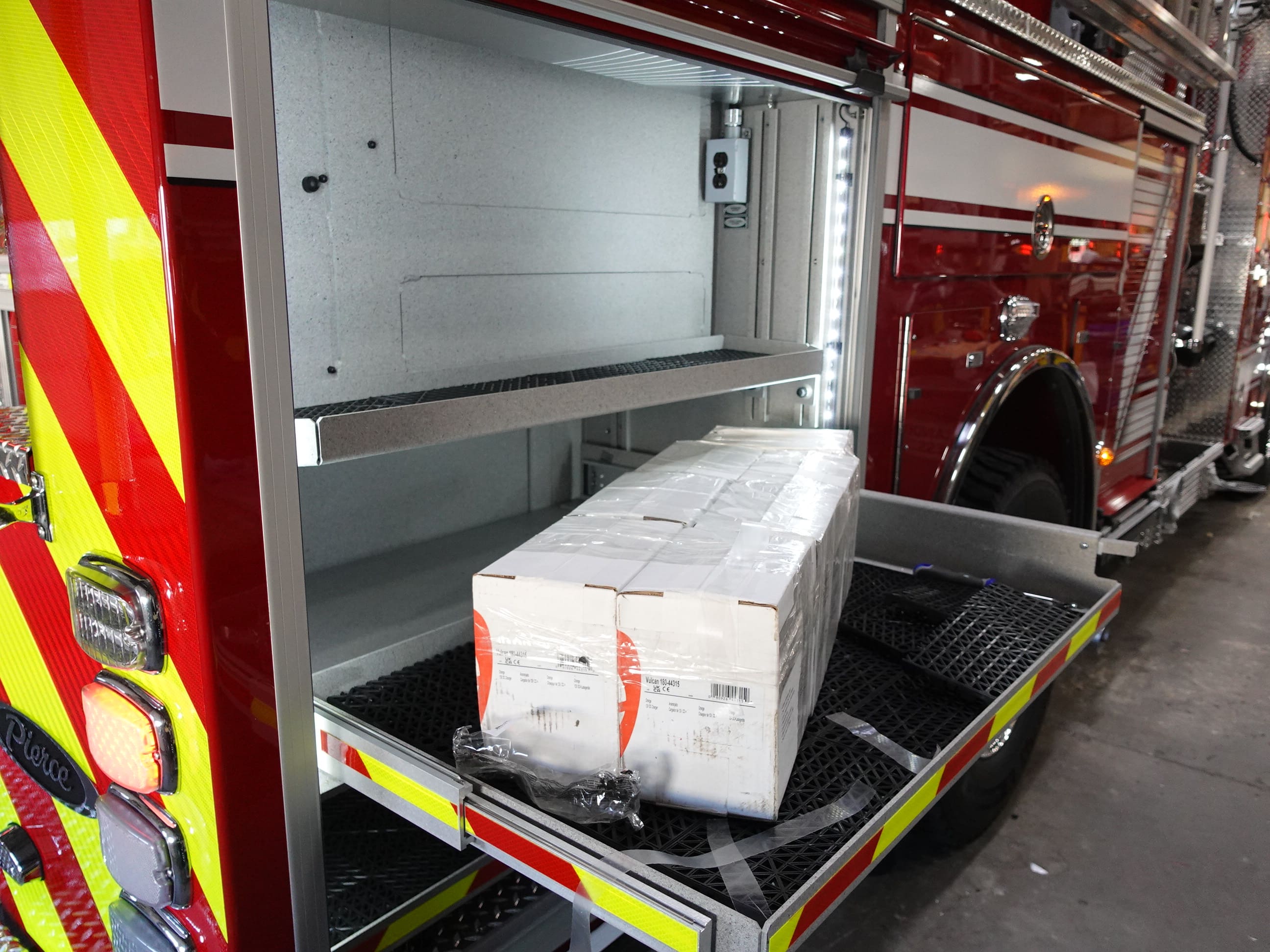

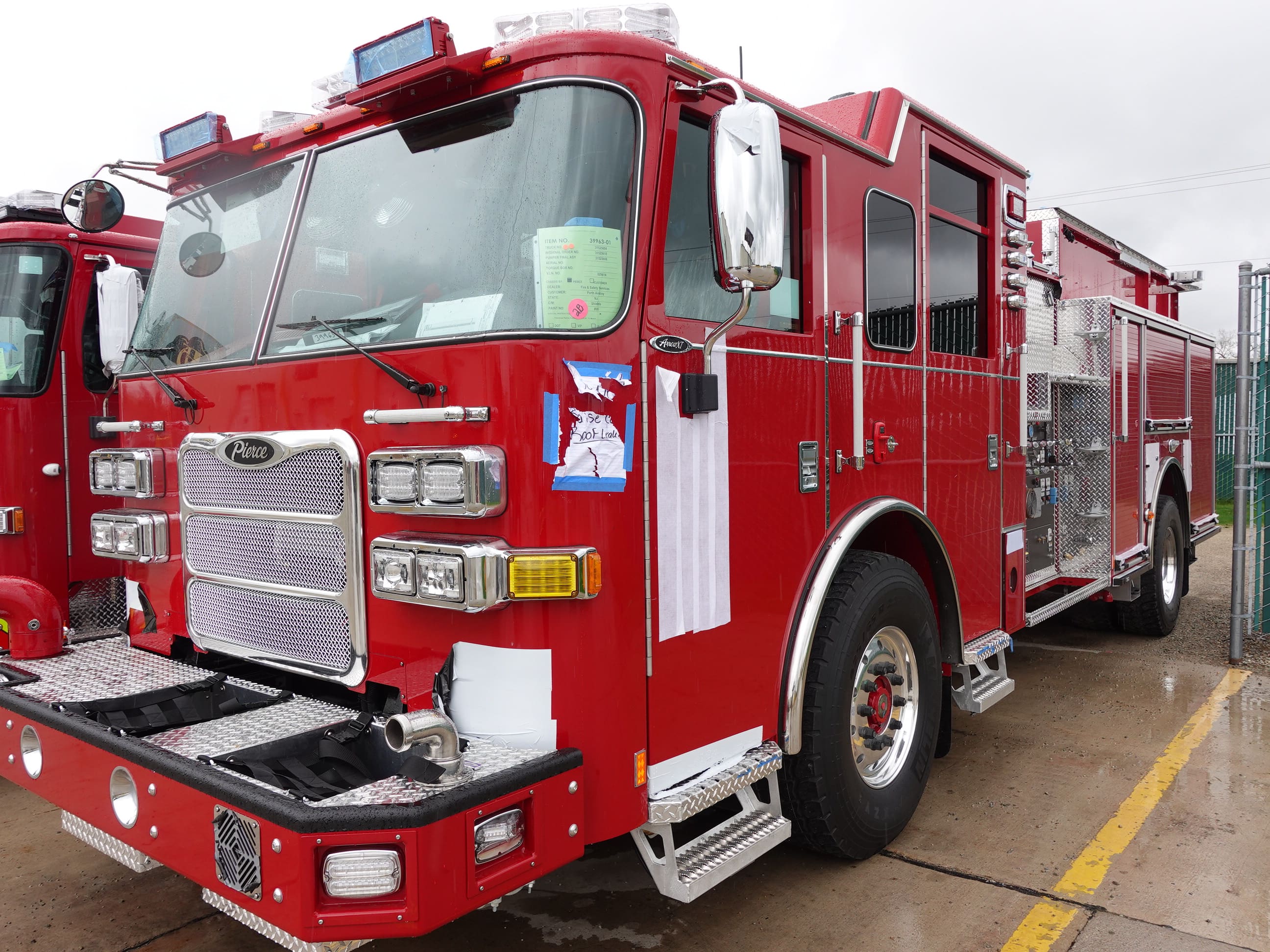

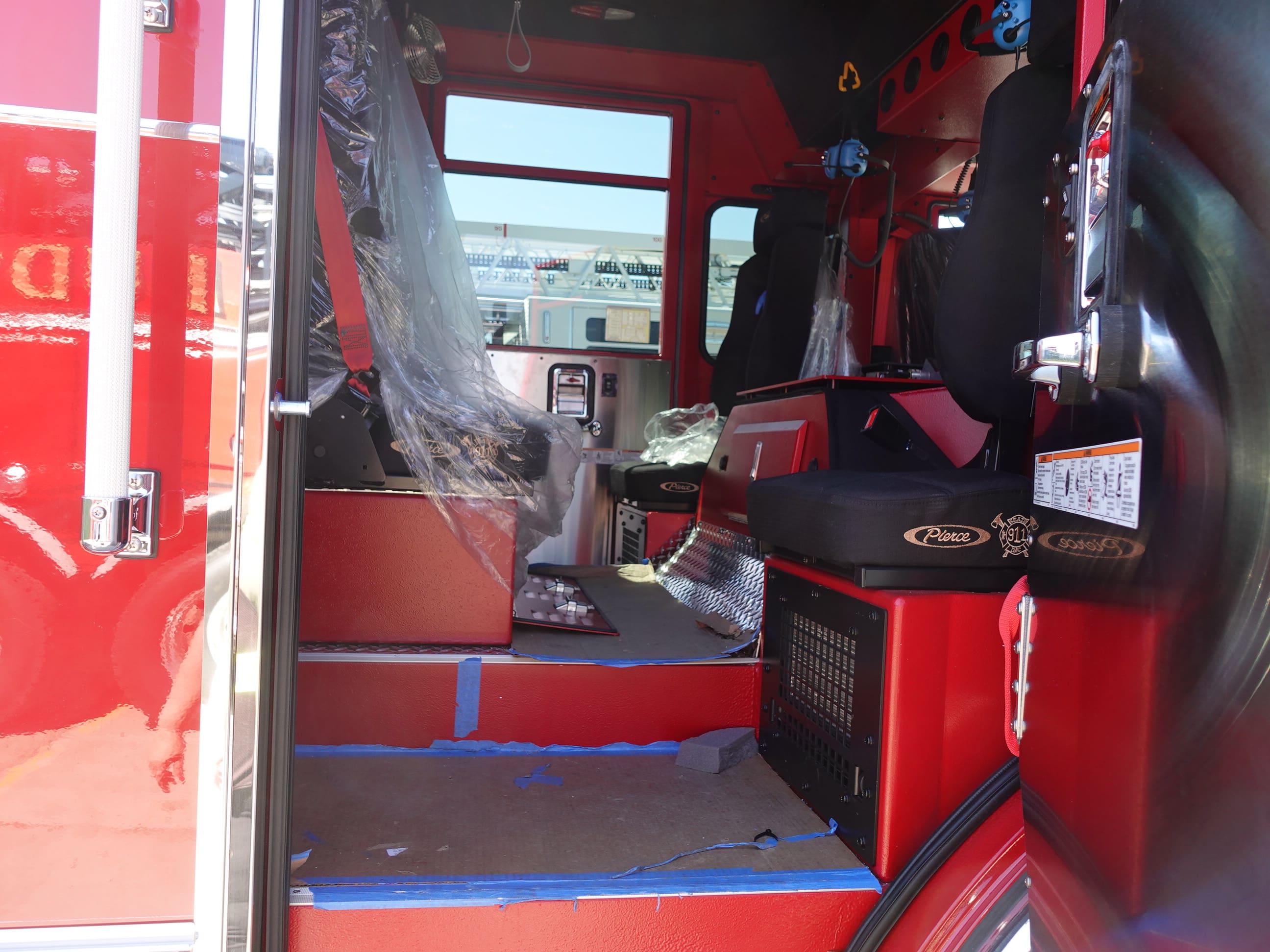

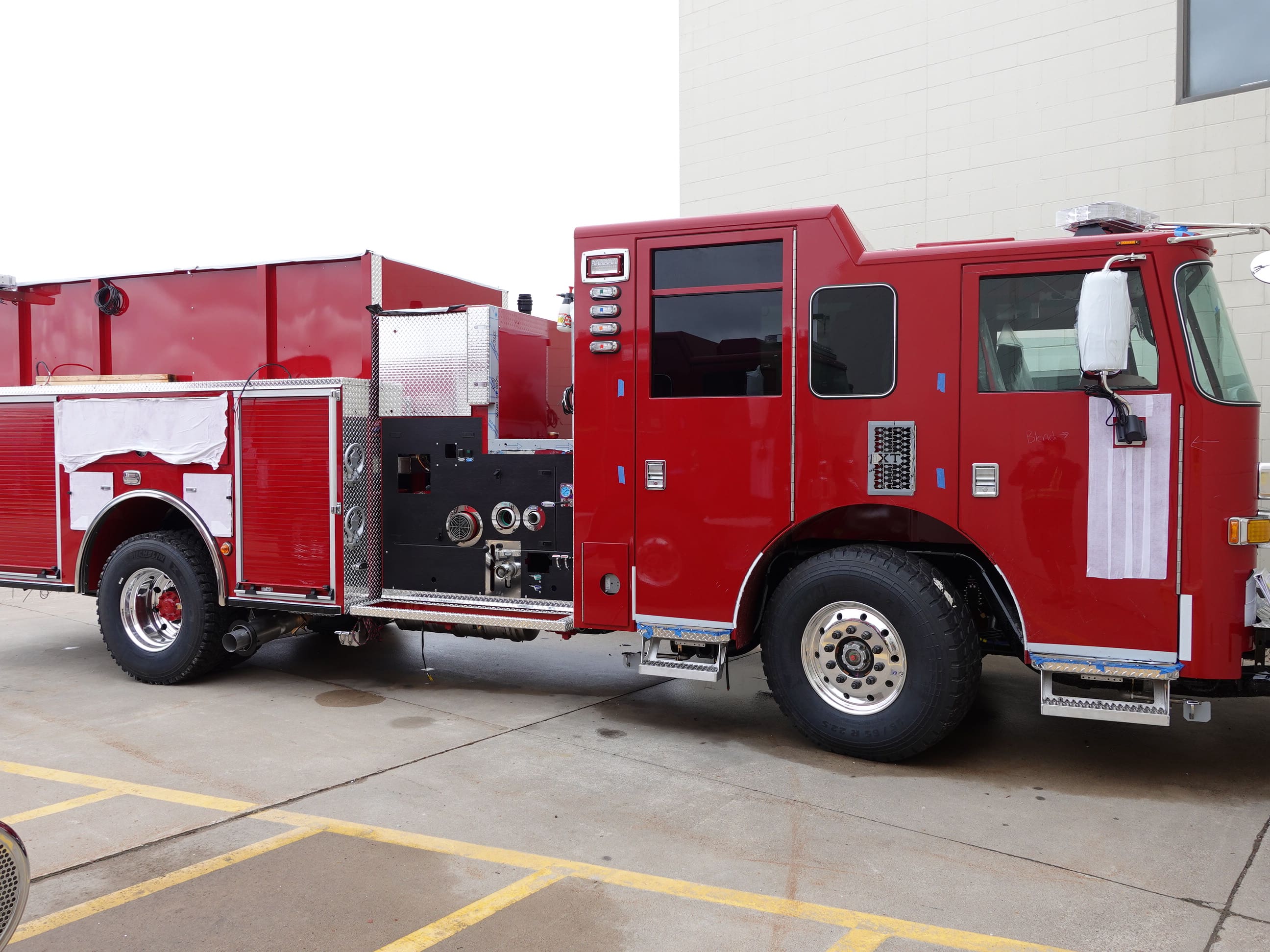

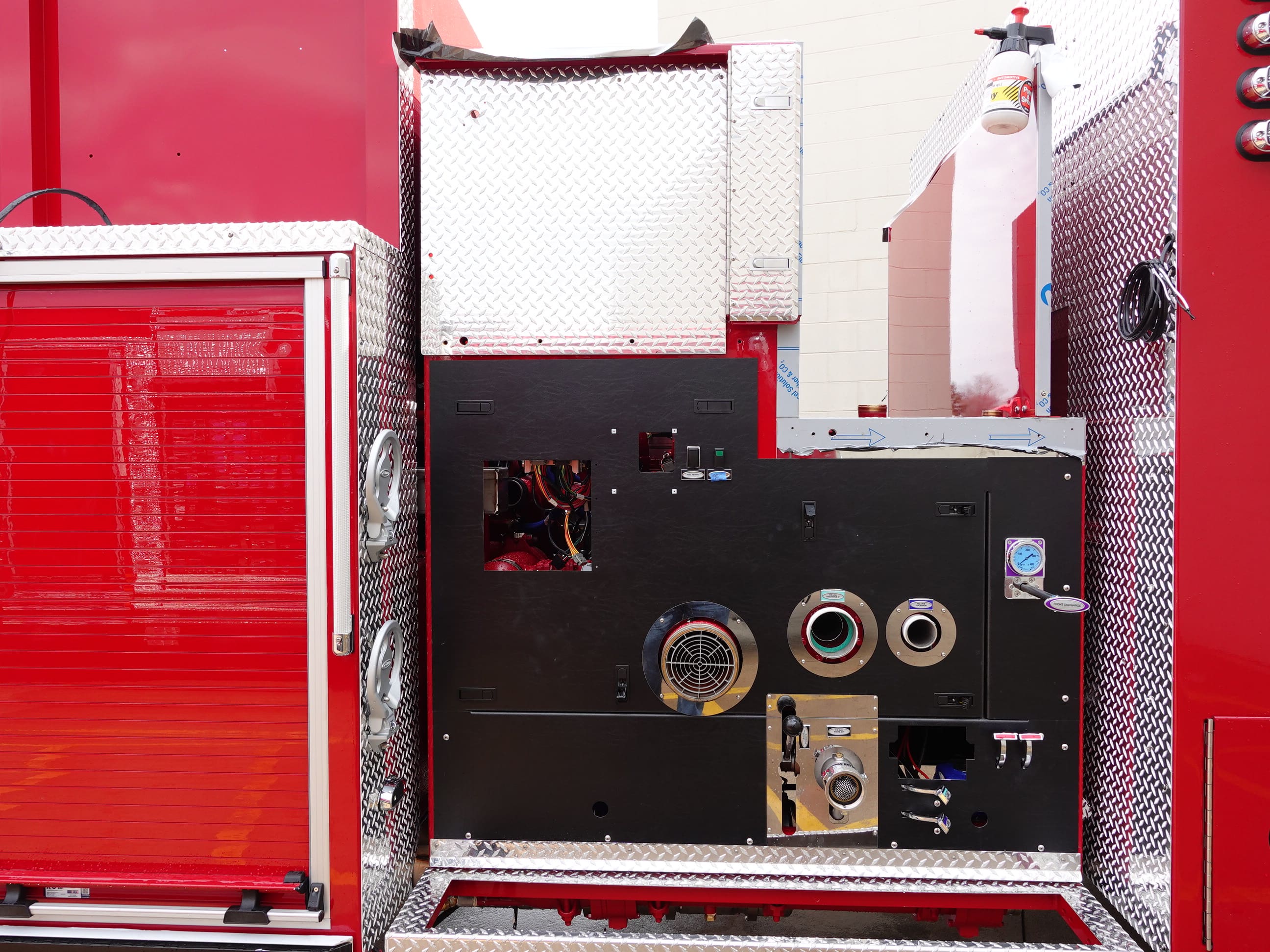

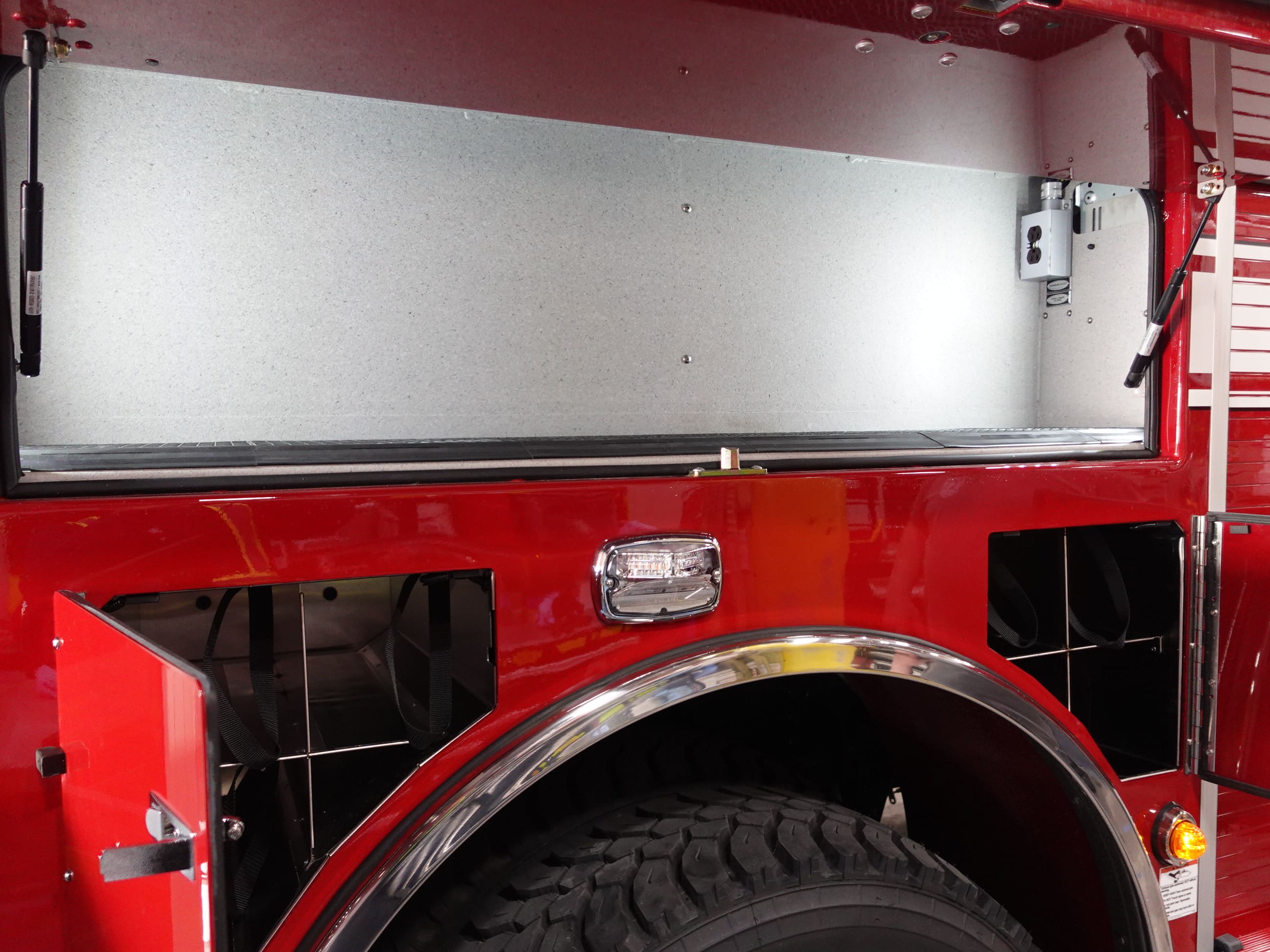

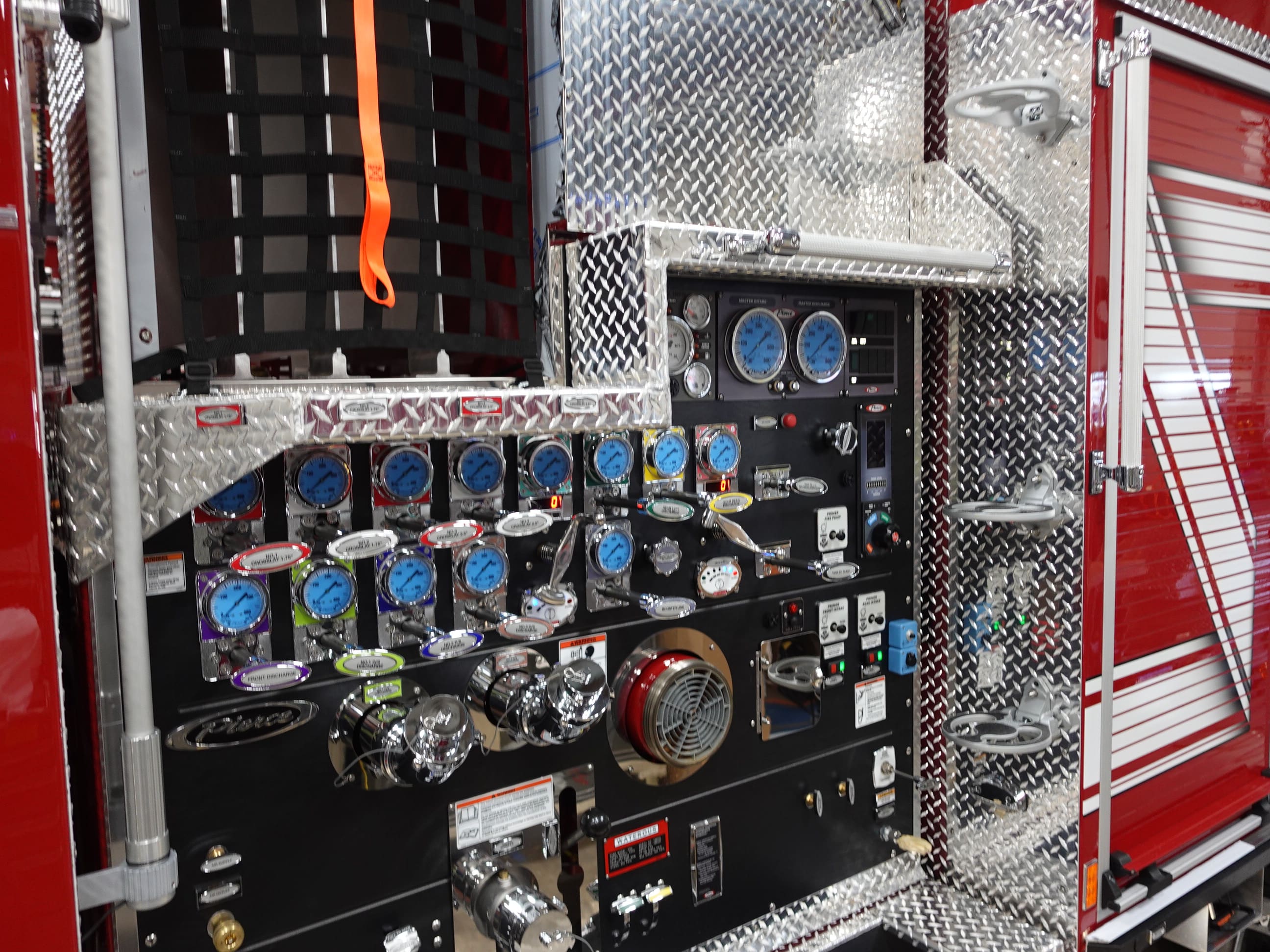

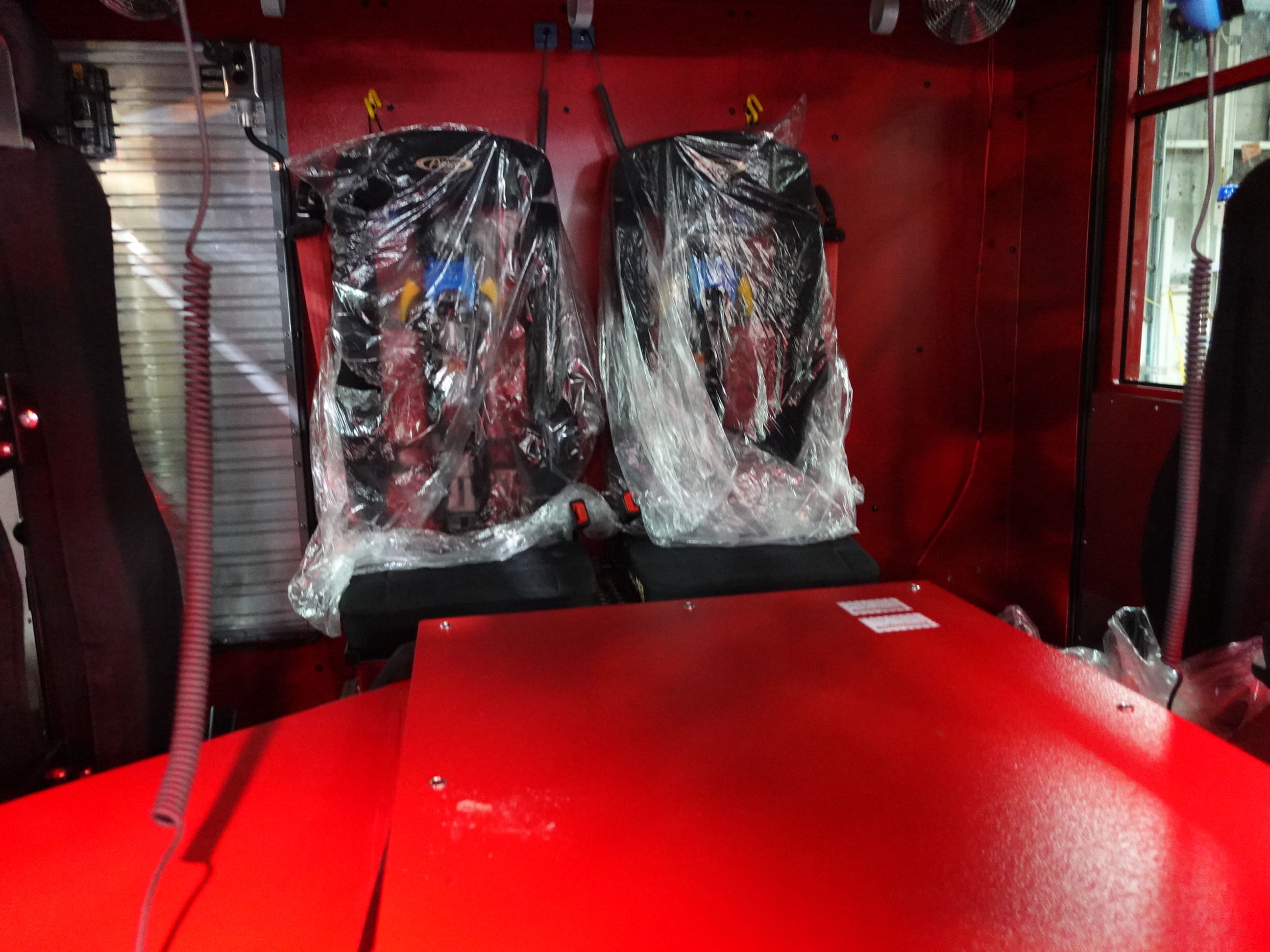

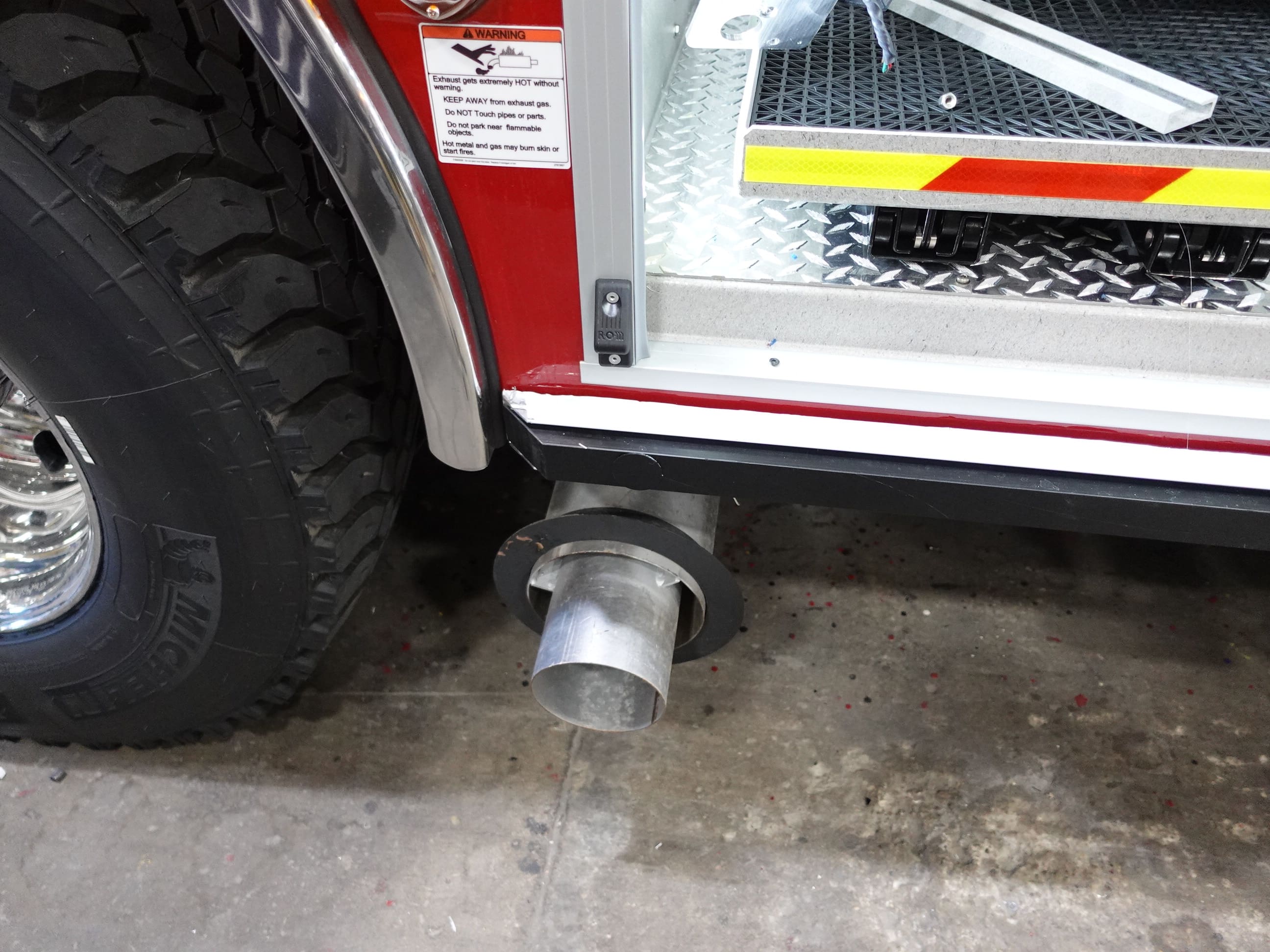

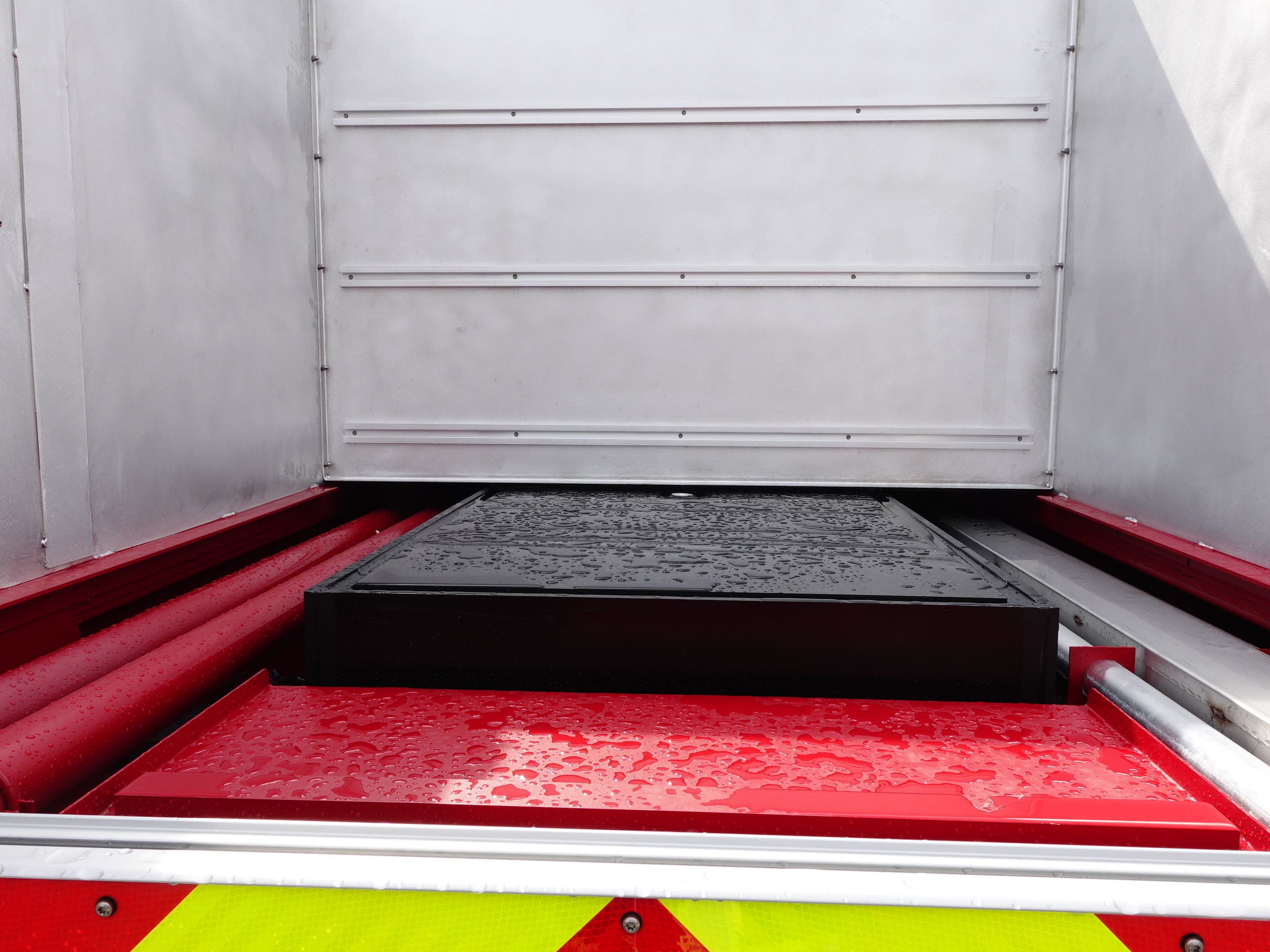

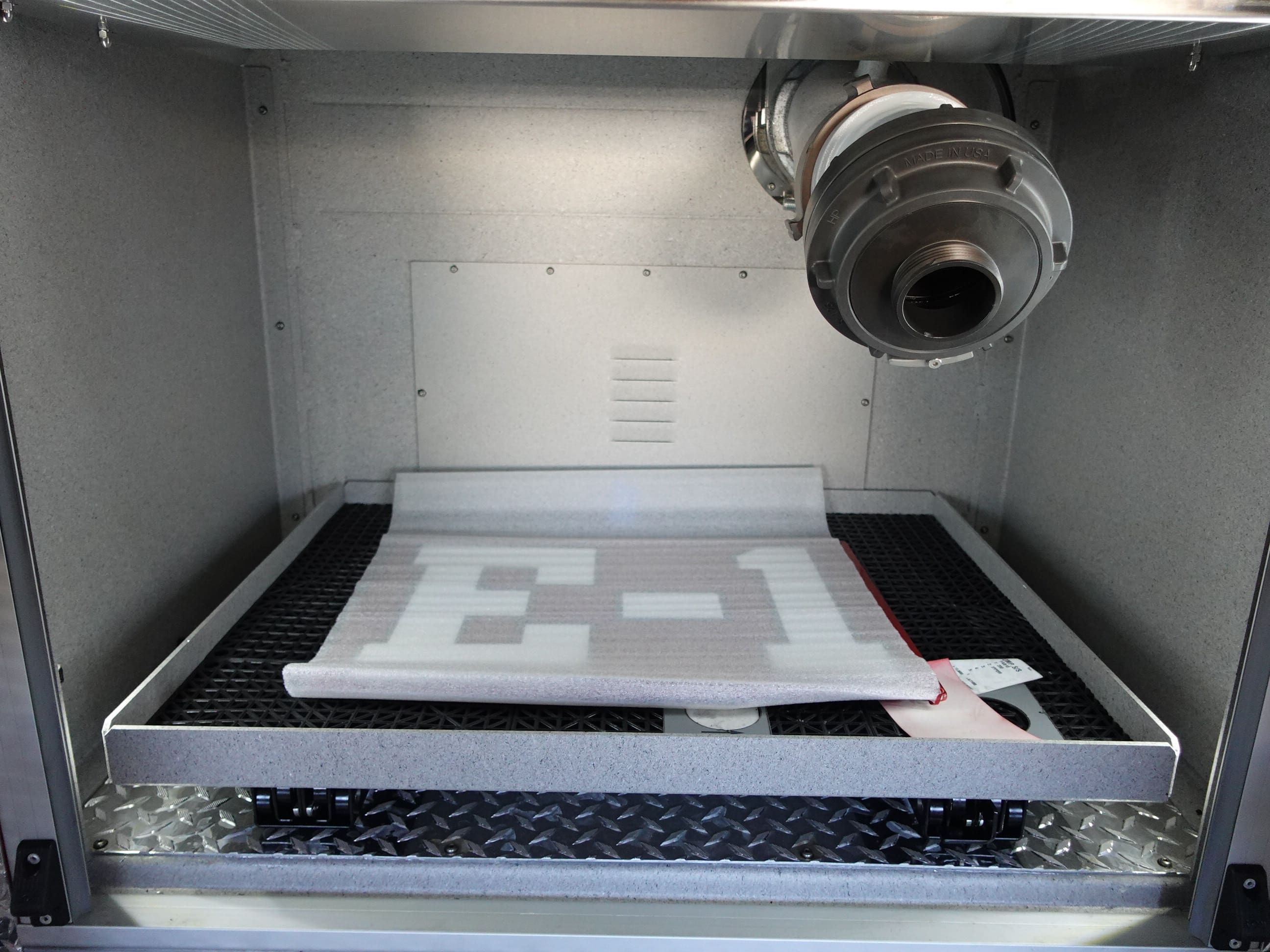

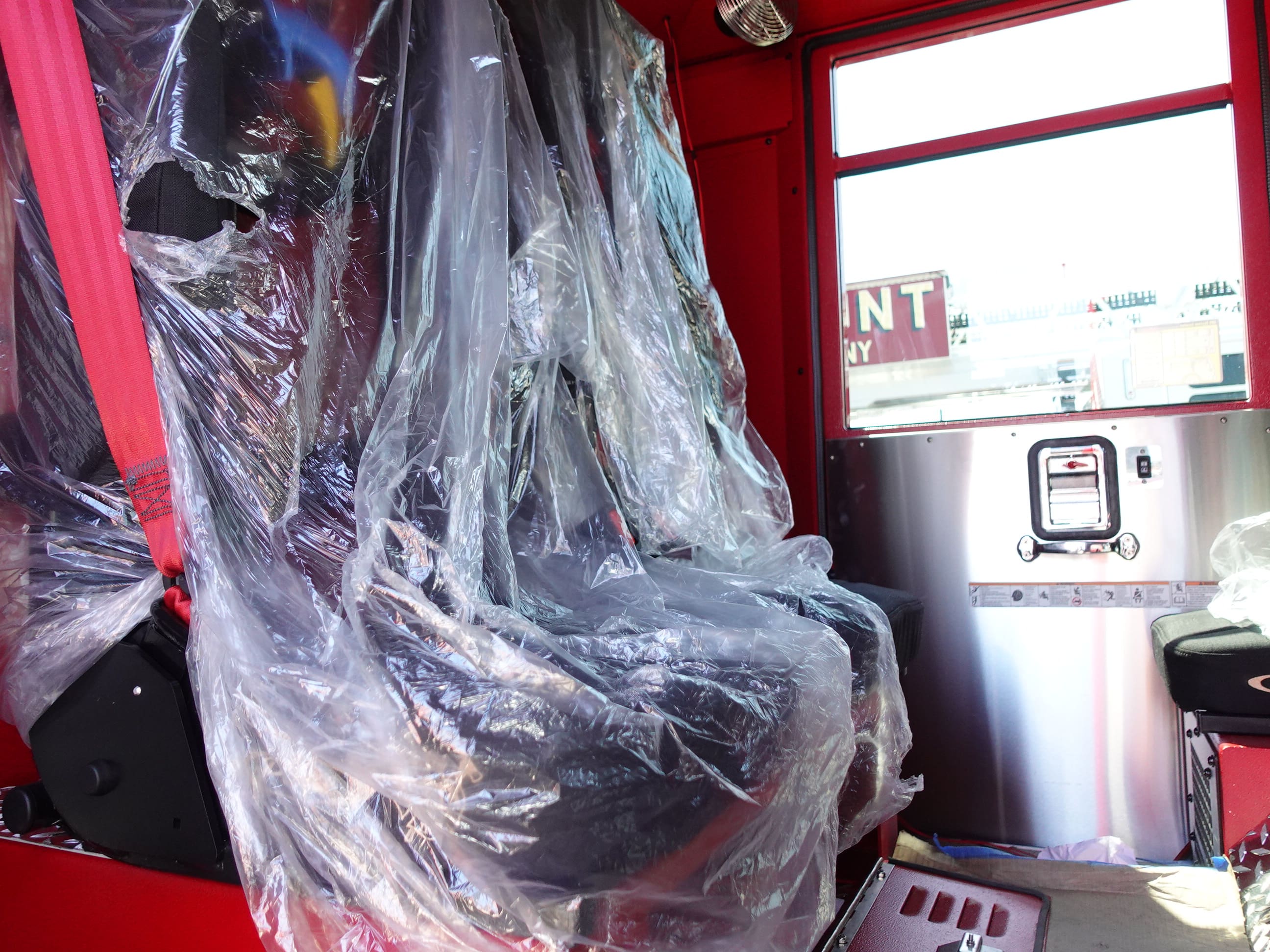

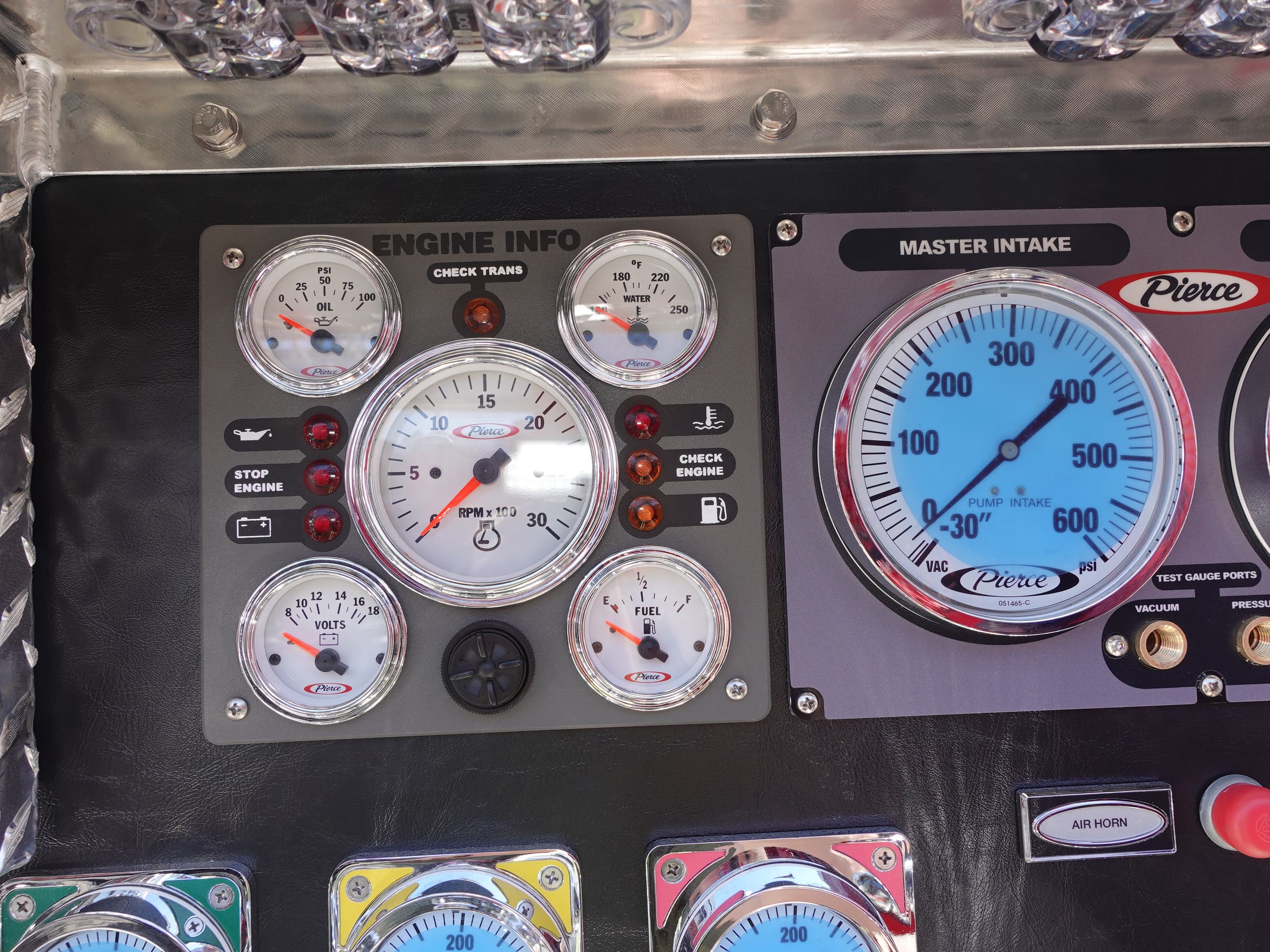

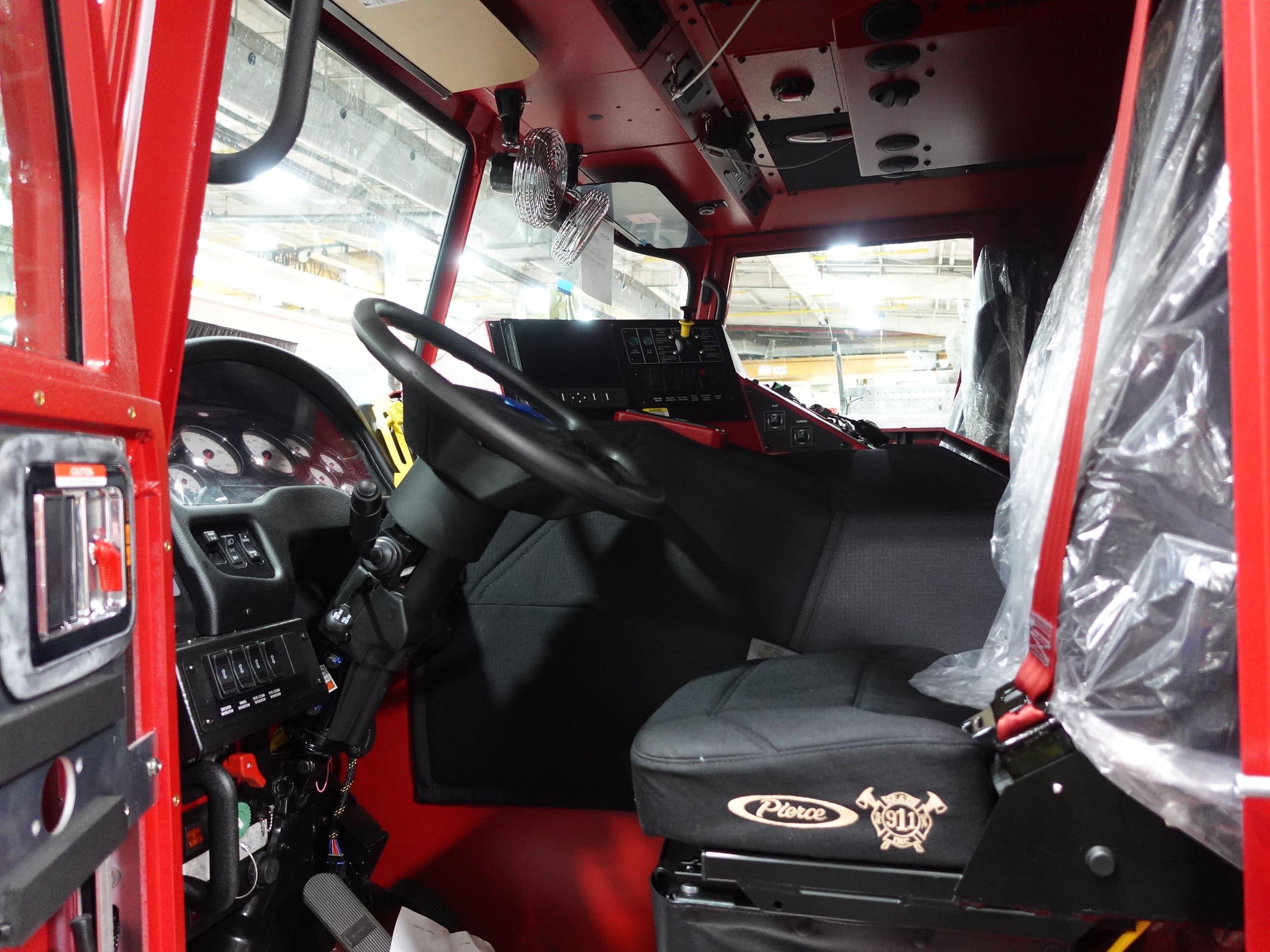

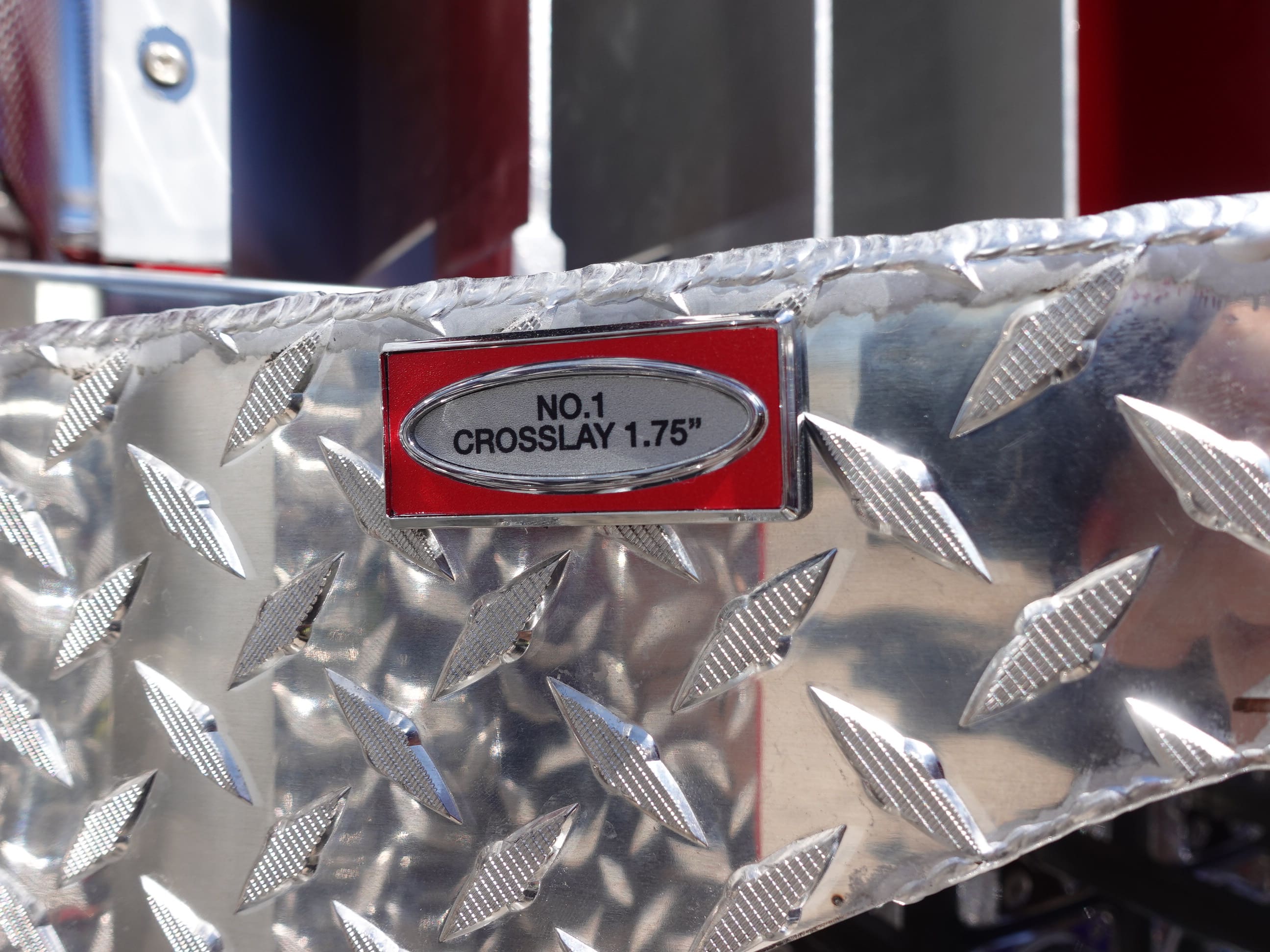

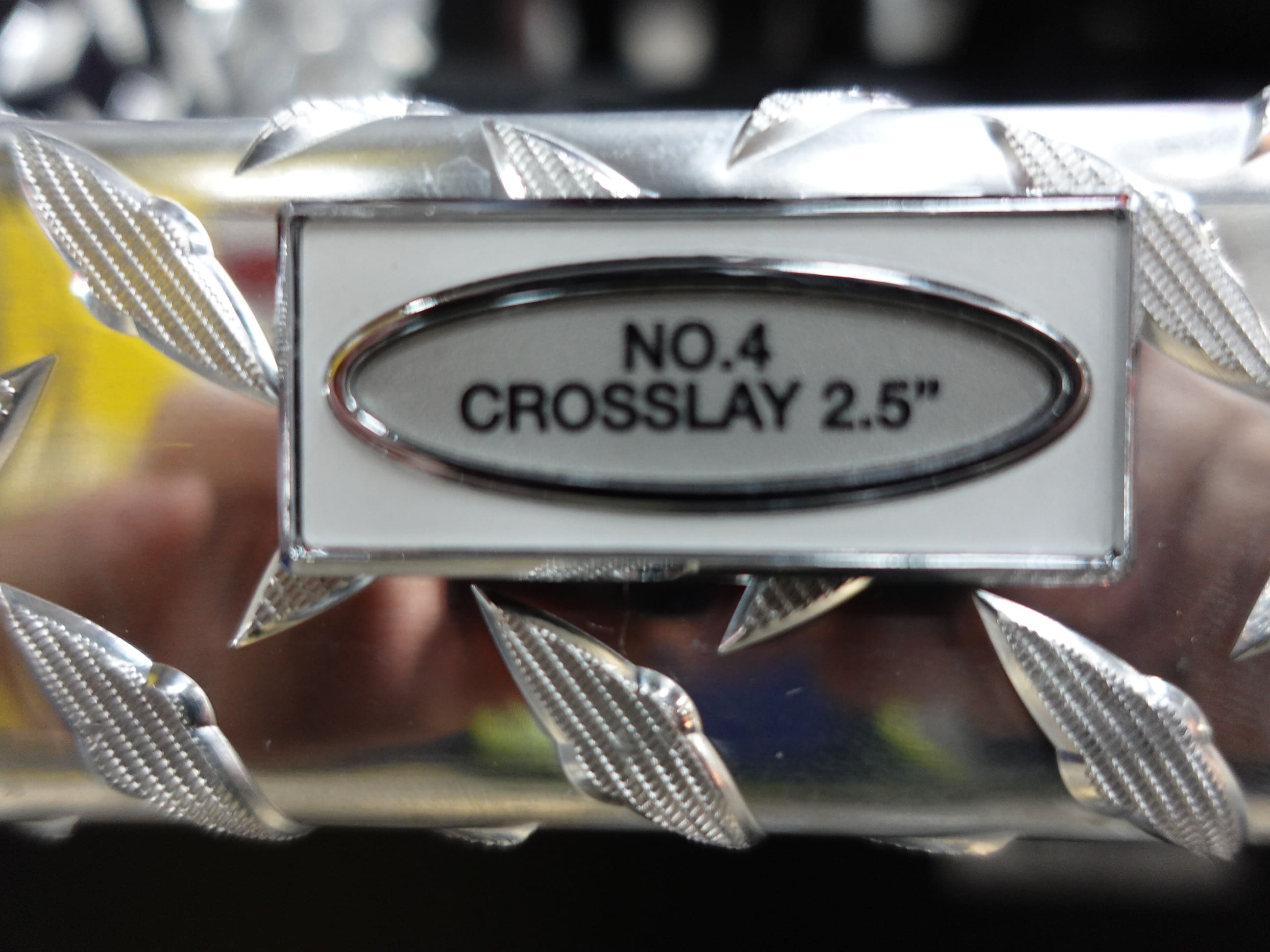

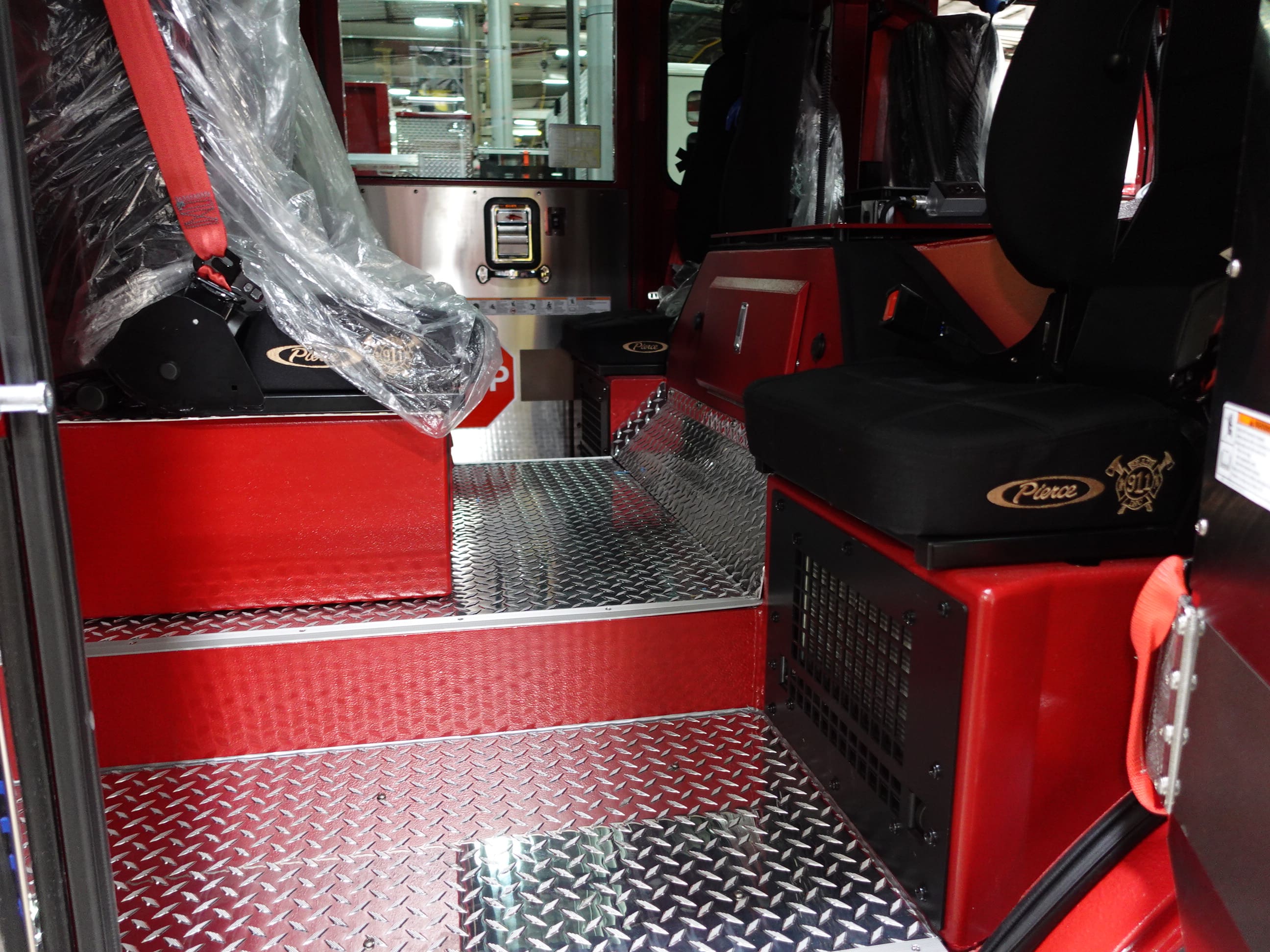

In this report, the apparatus completed testing and
released to quality and graphics where any

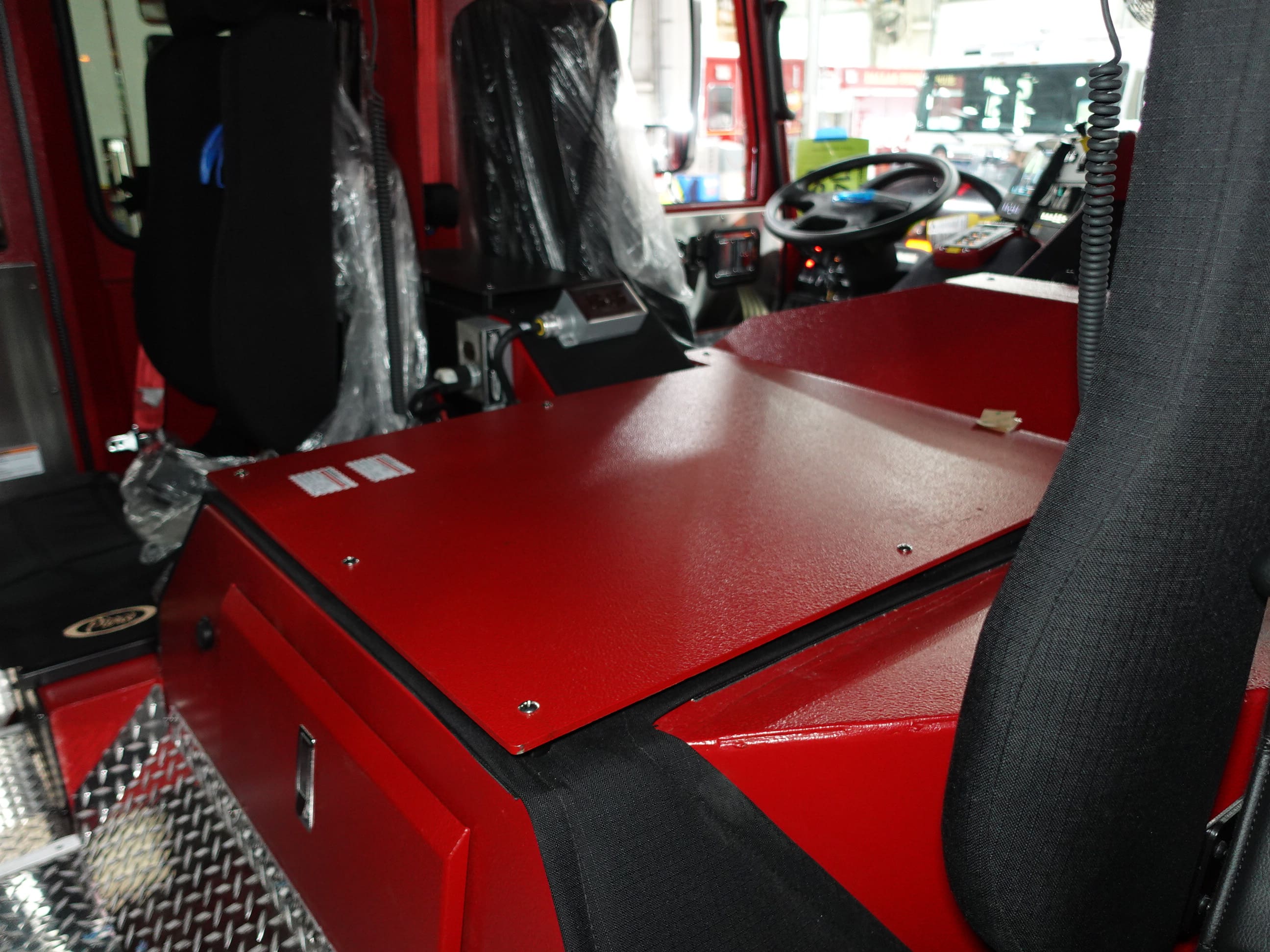

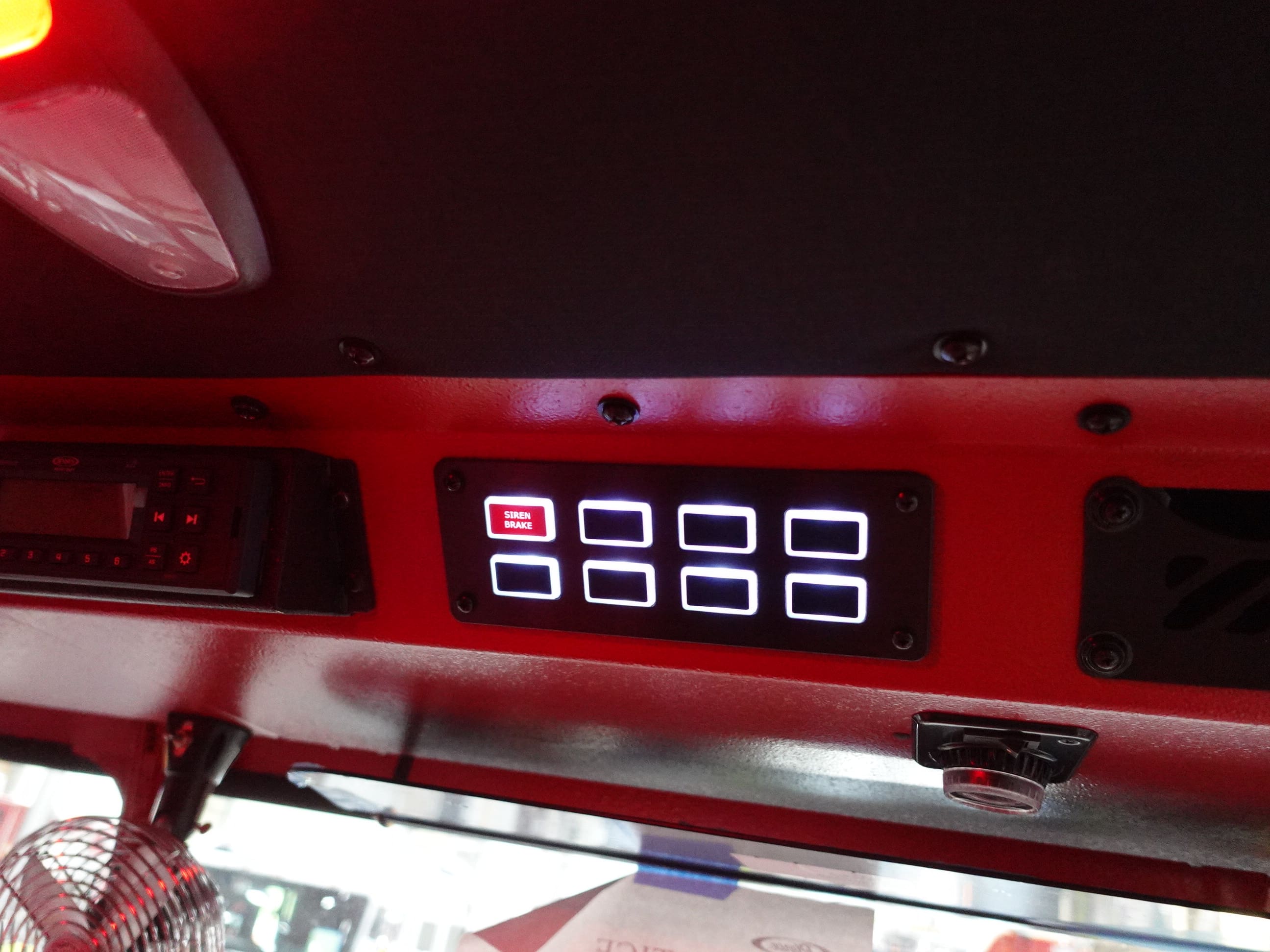

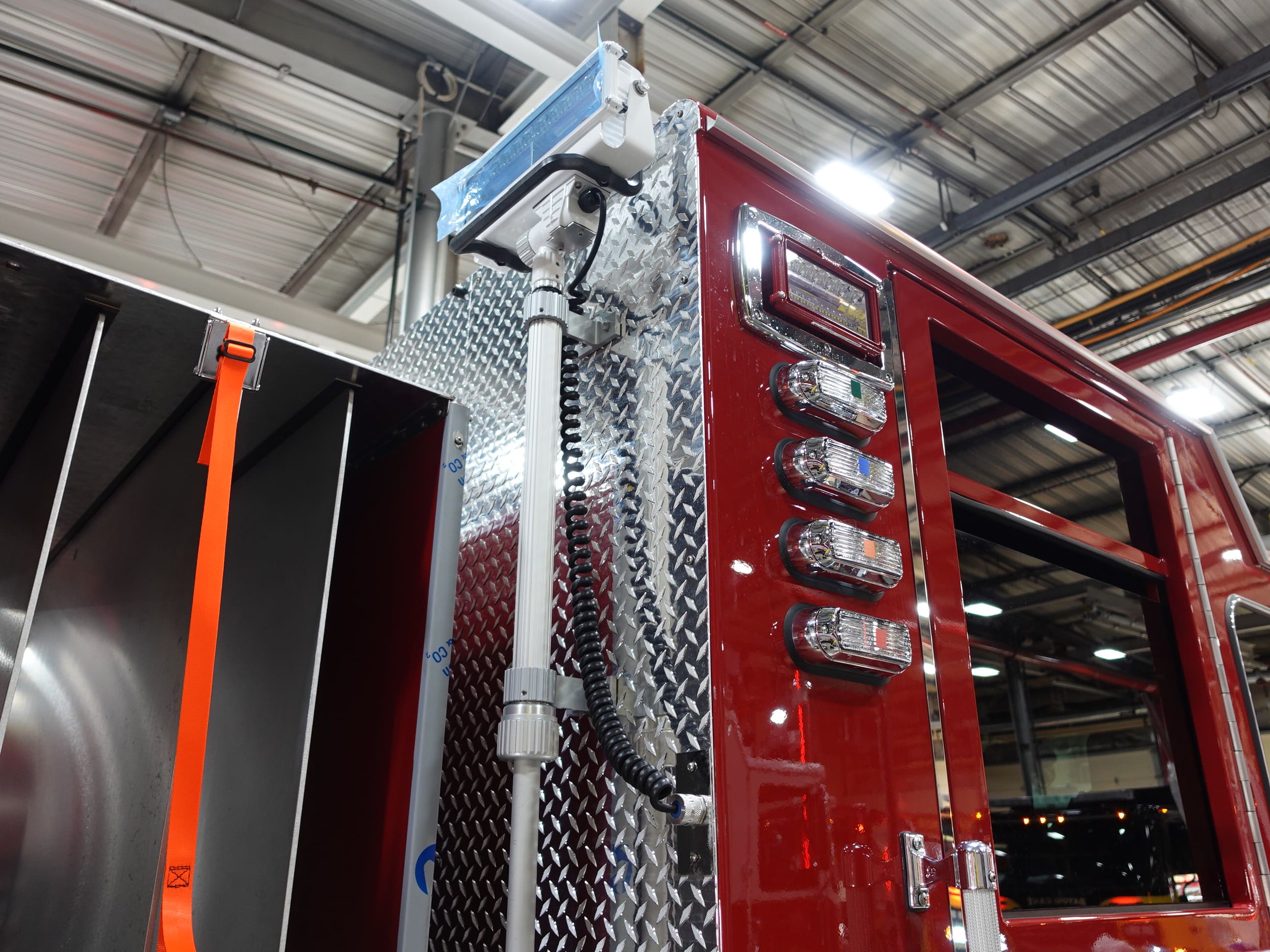

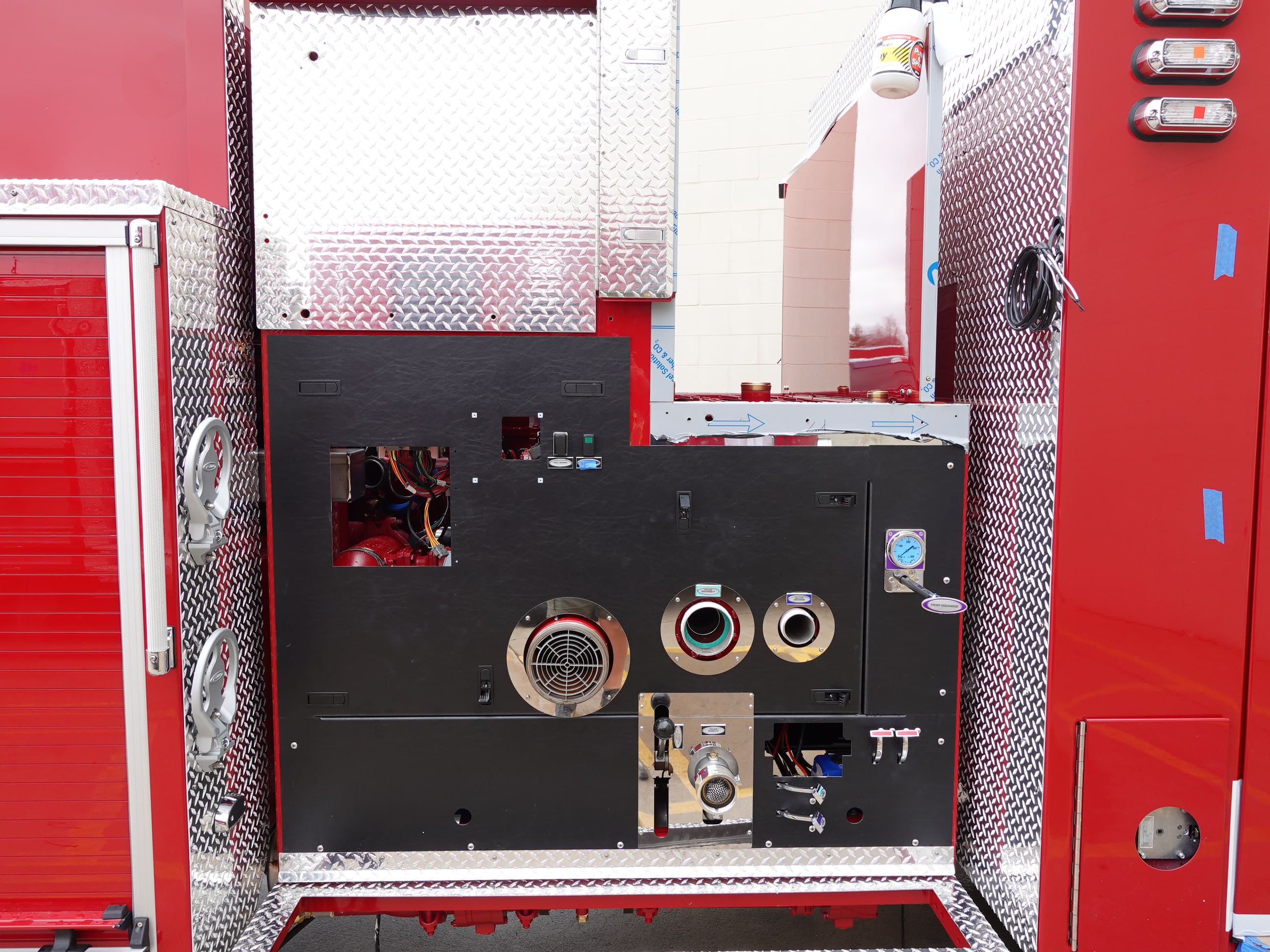

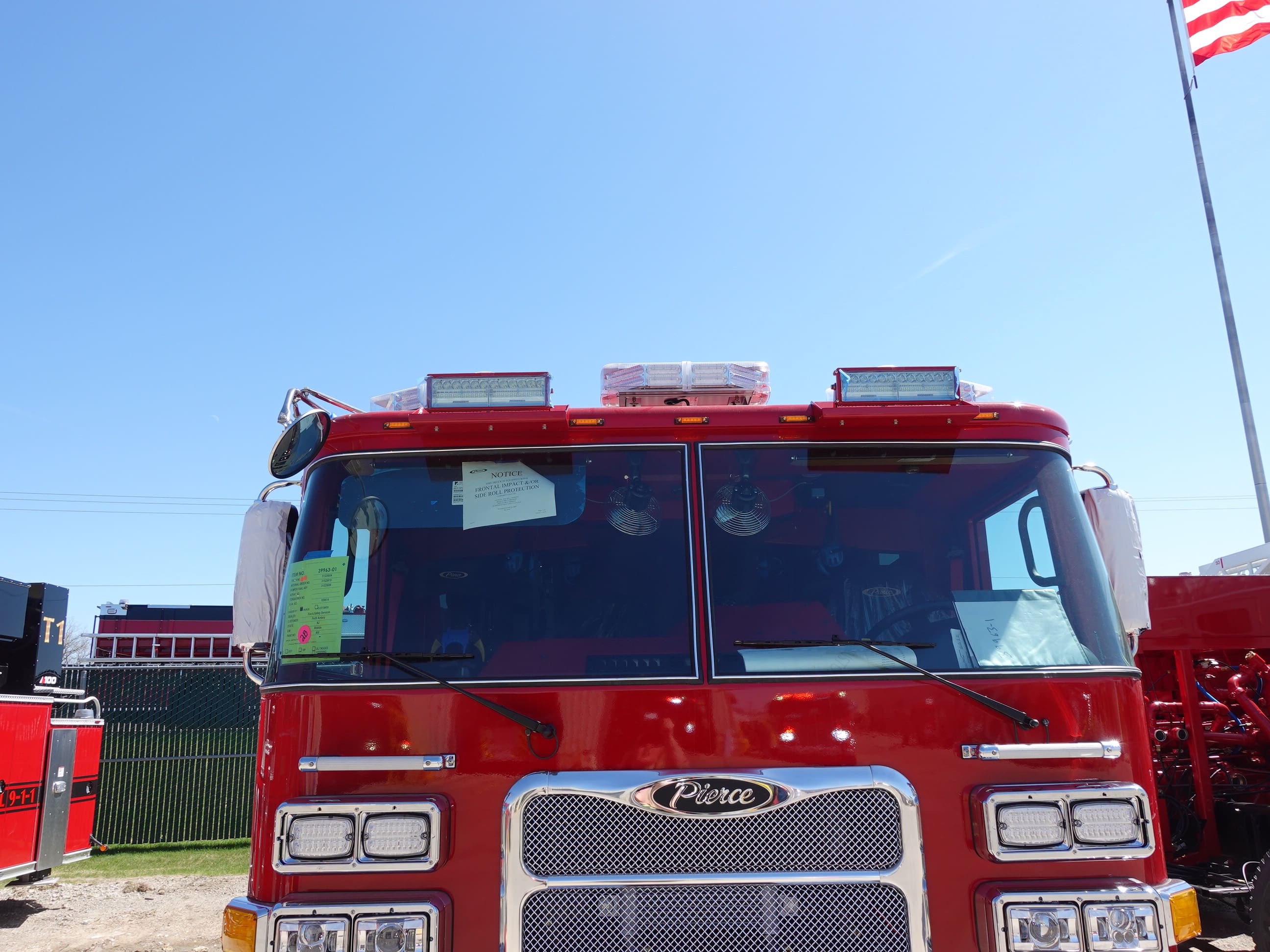

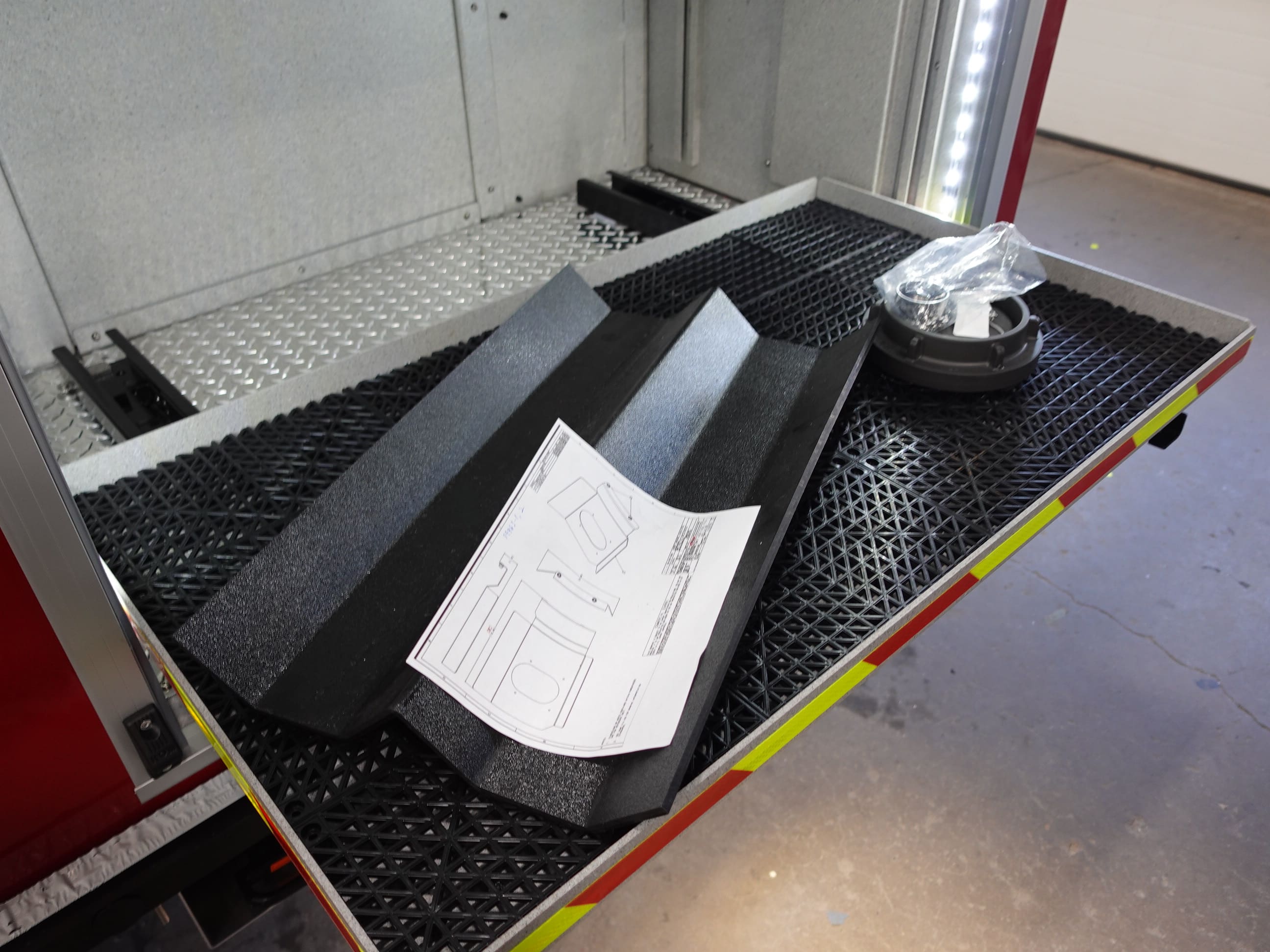

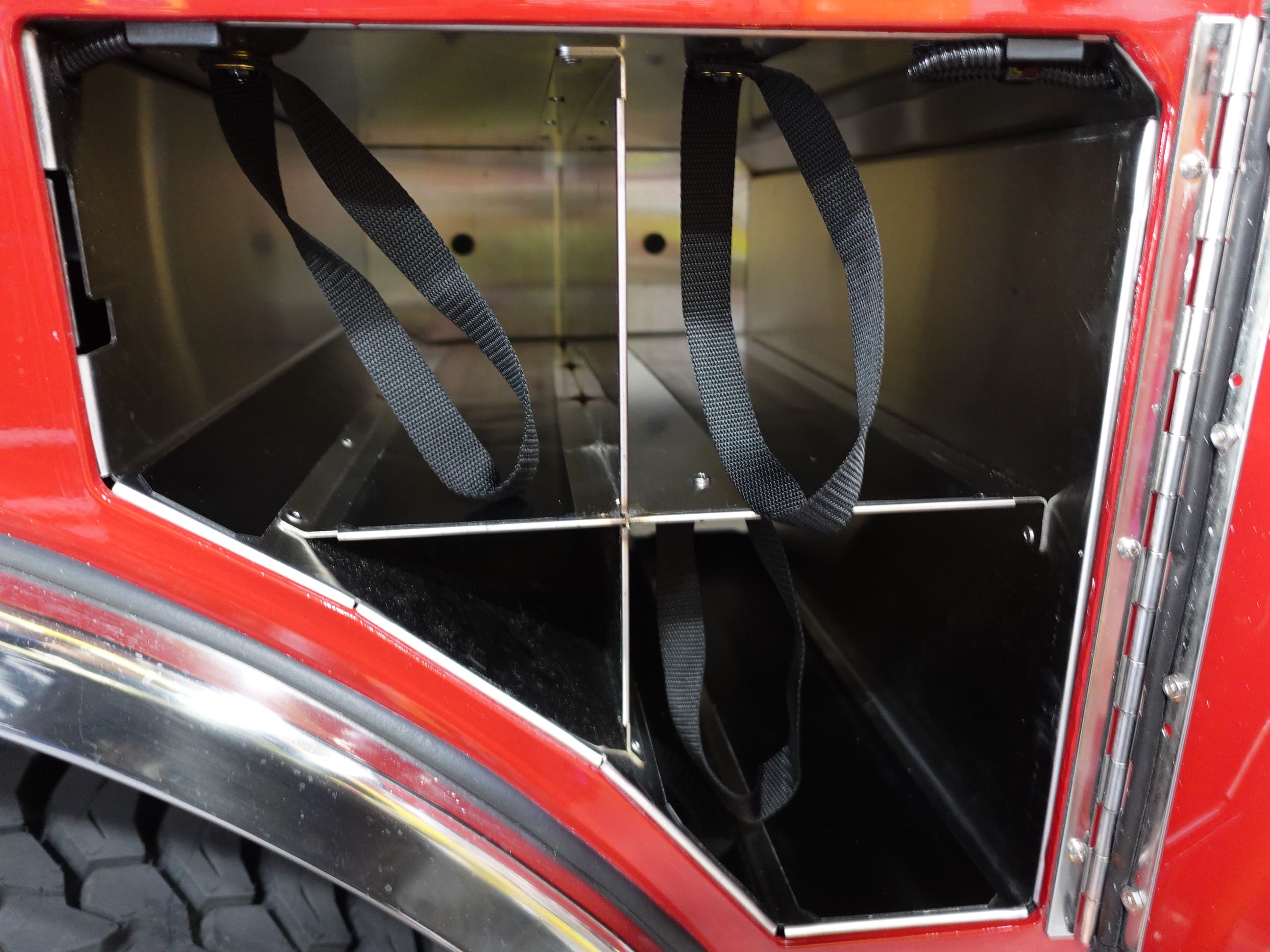

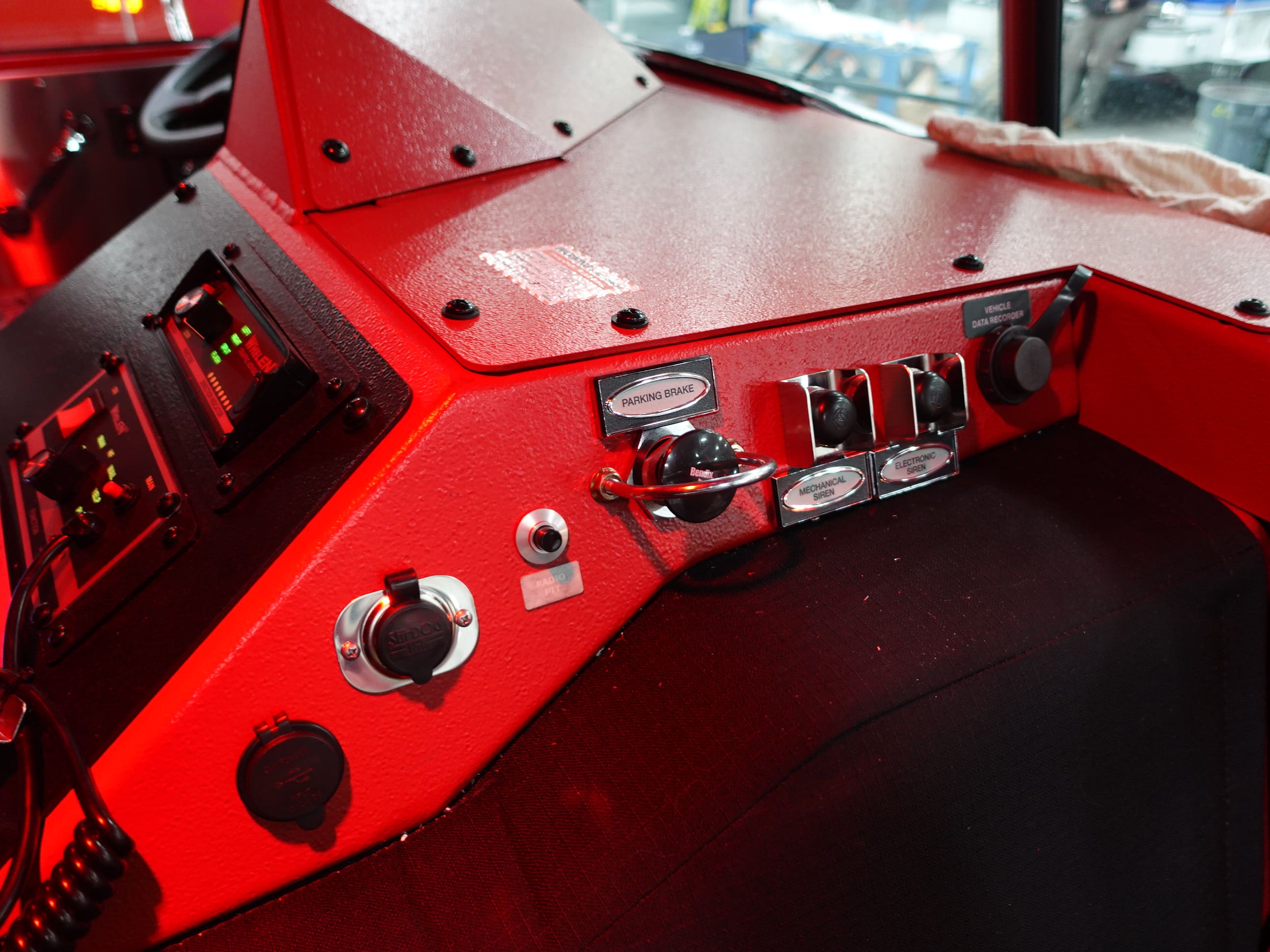

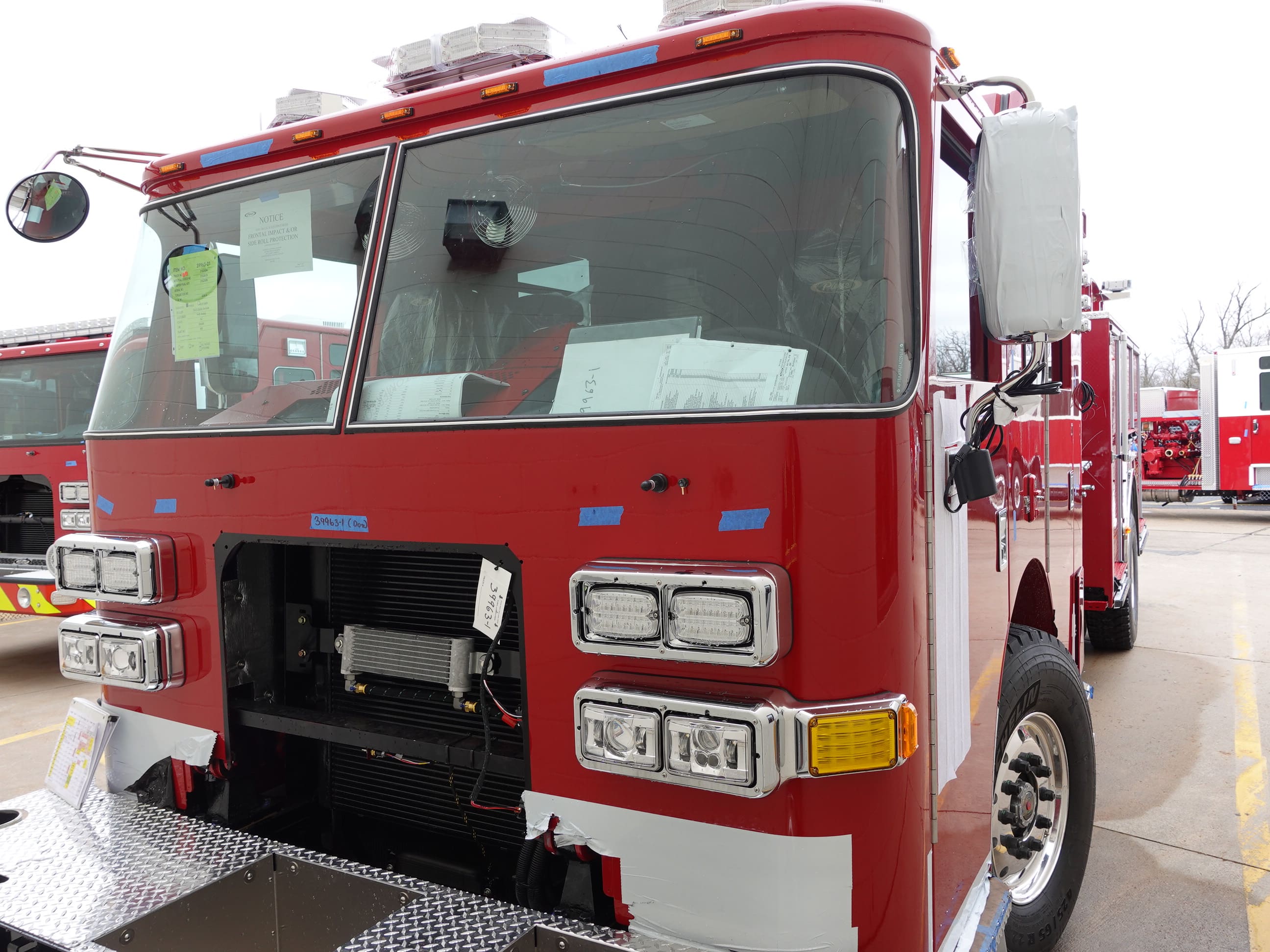

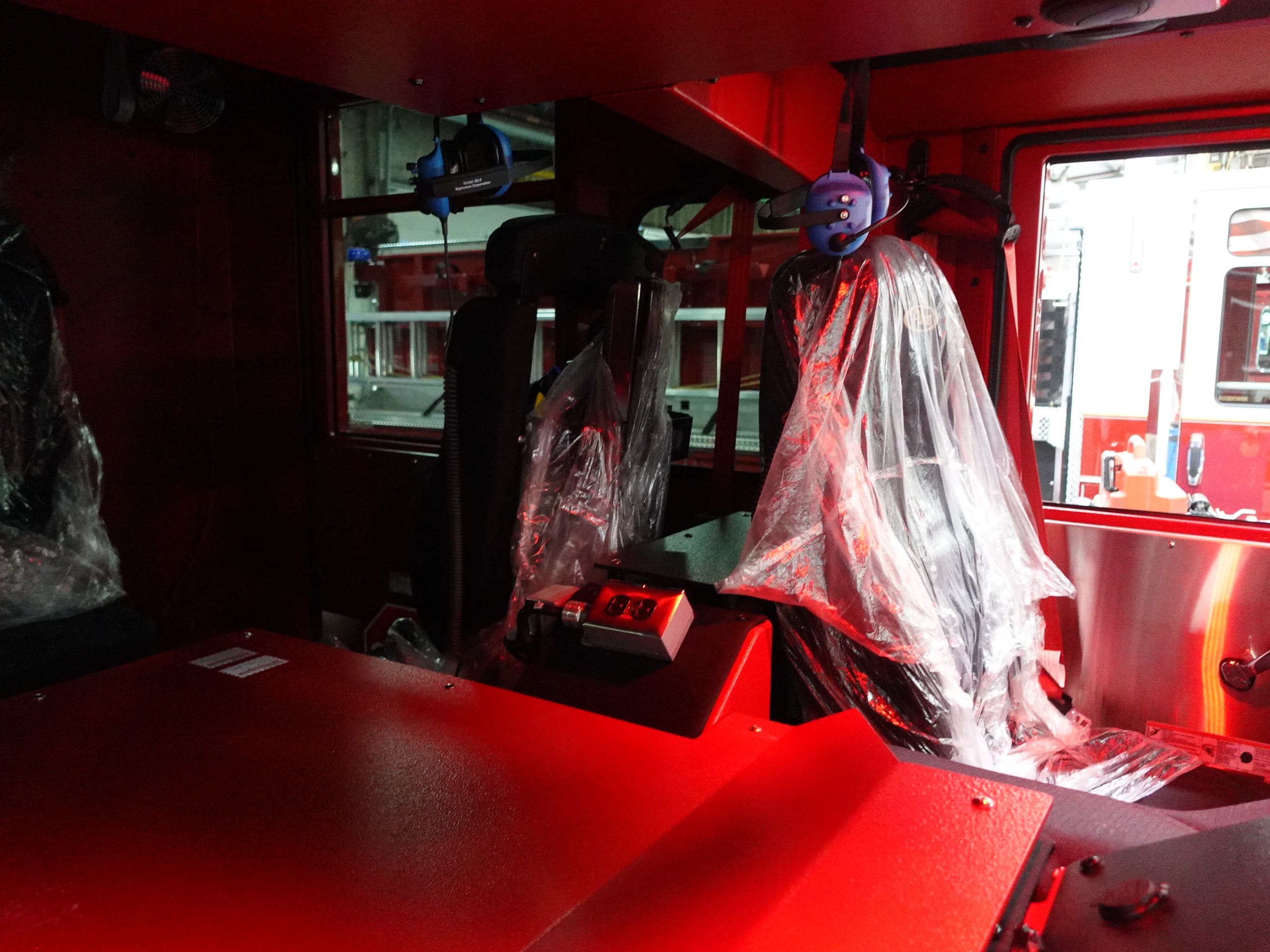

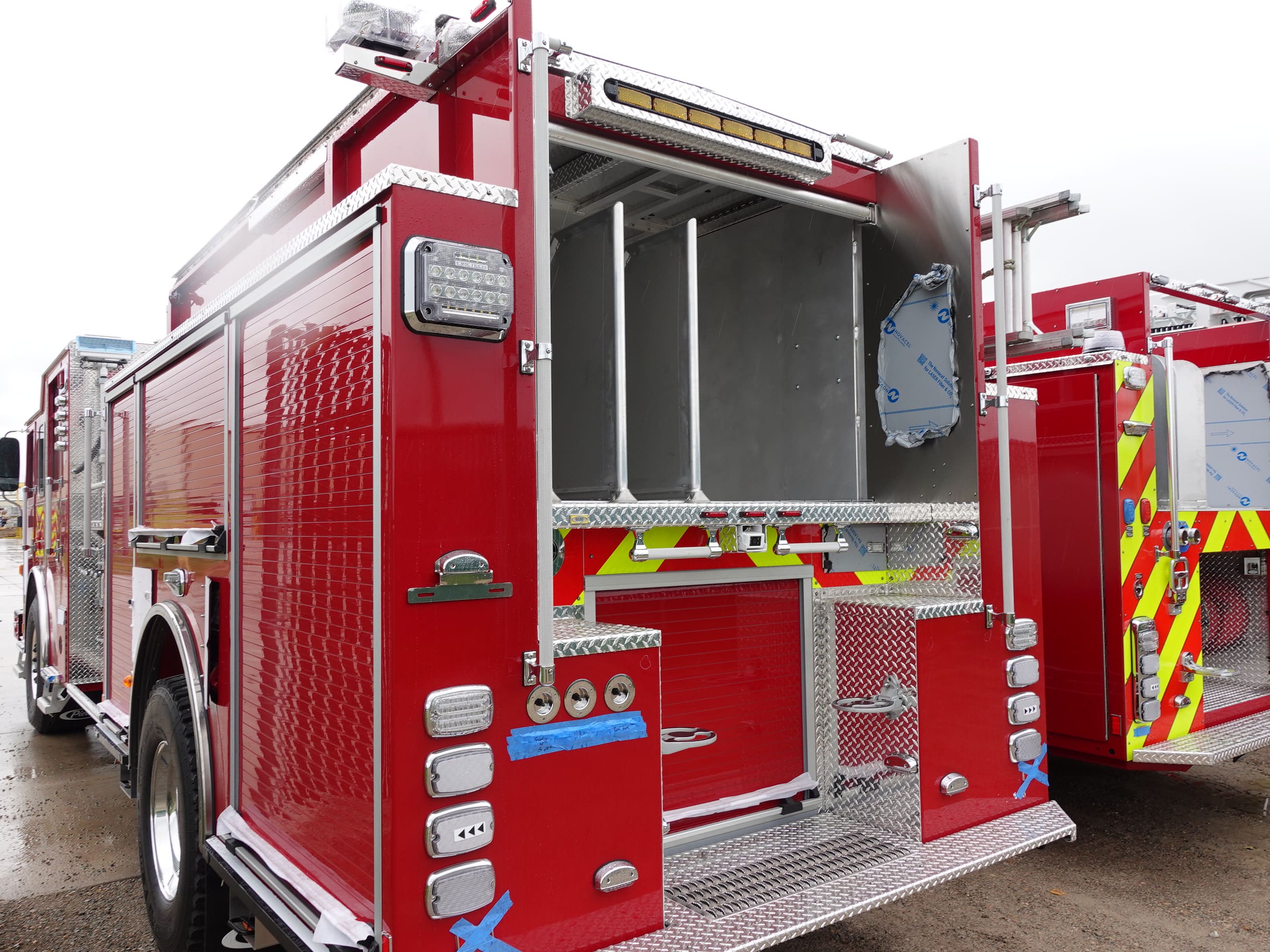

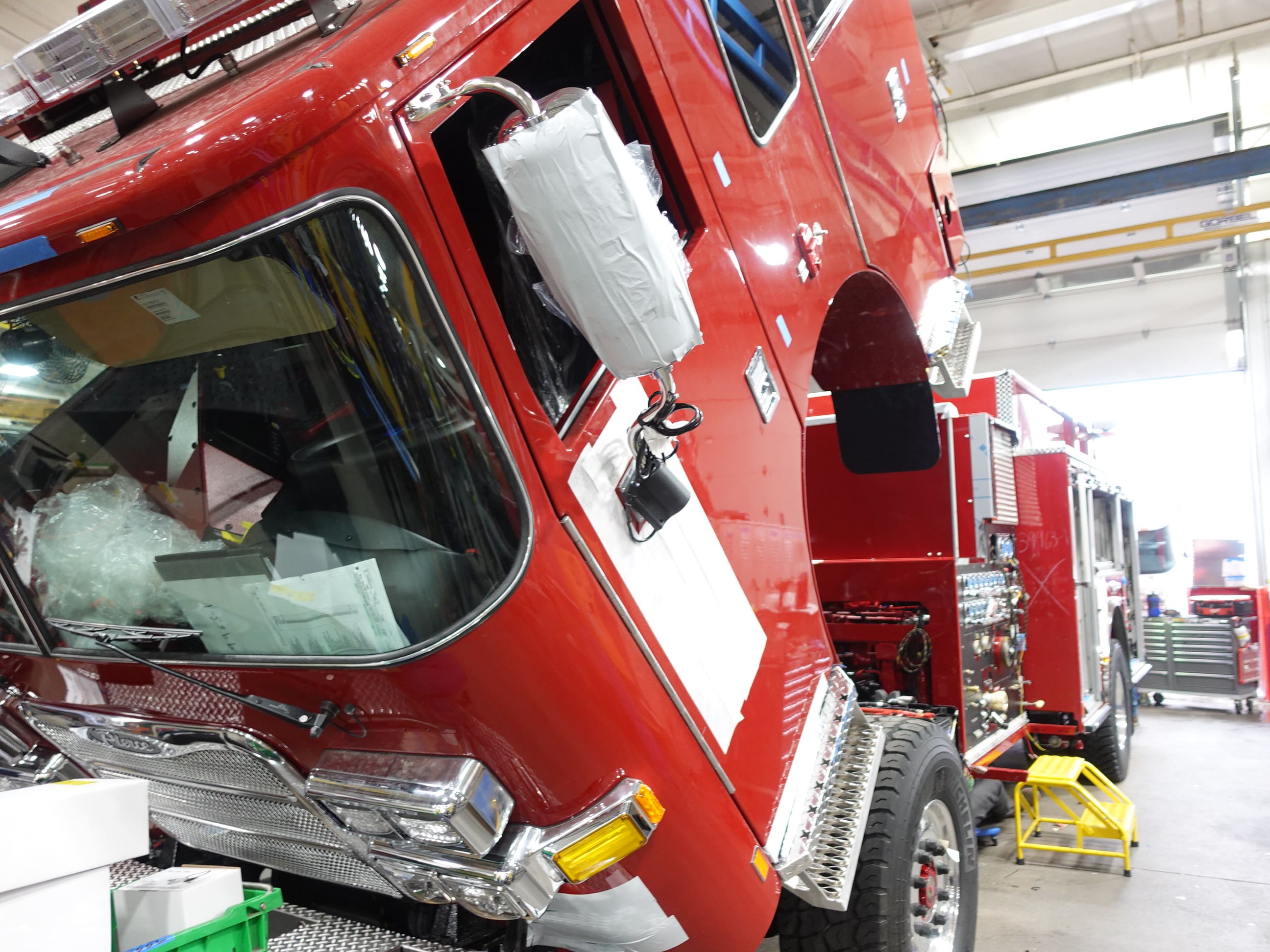

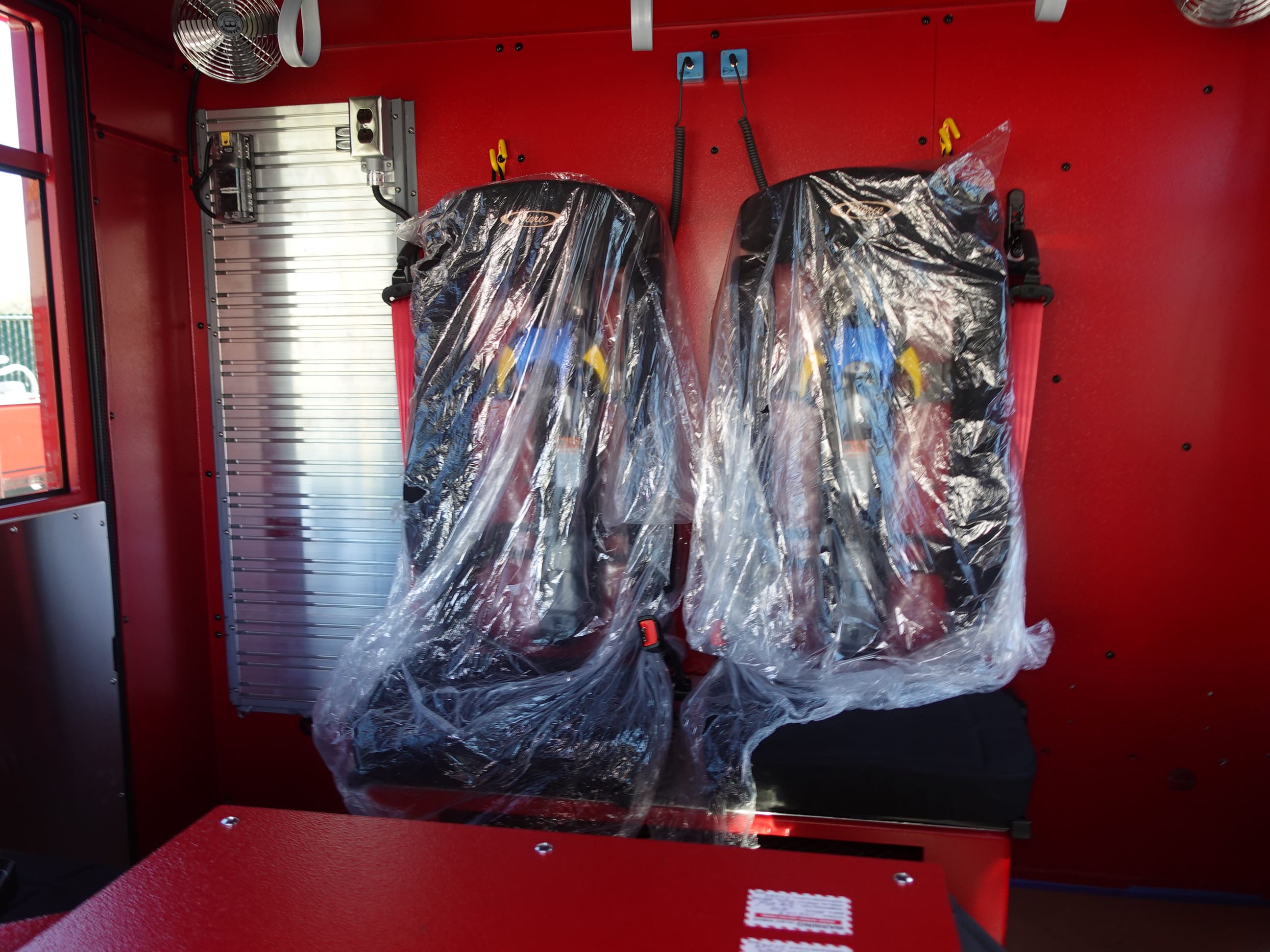

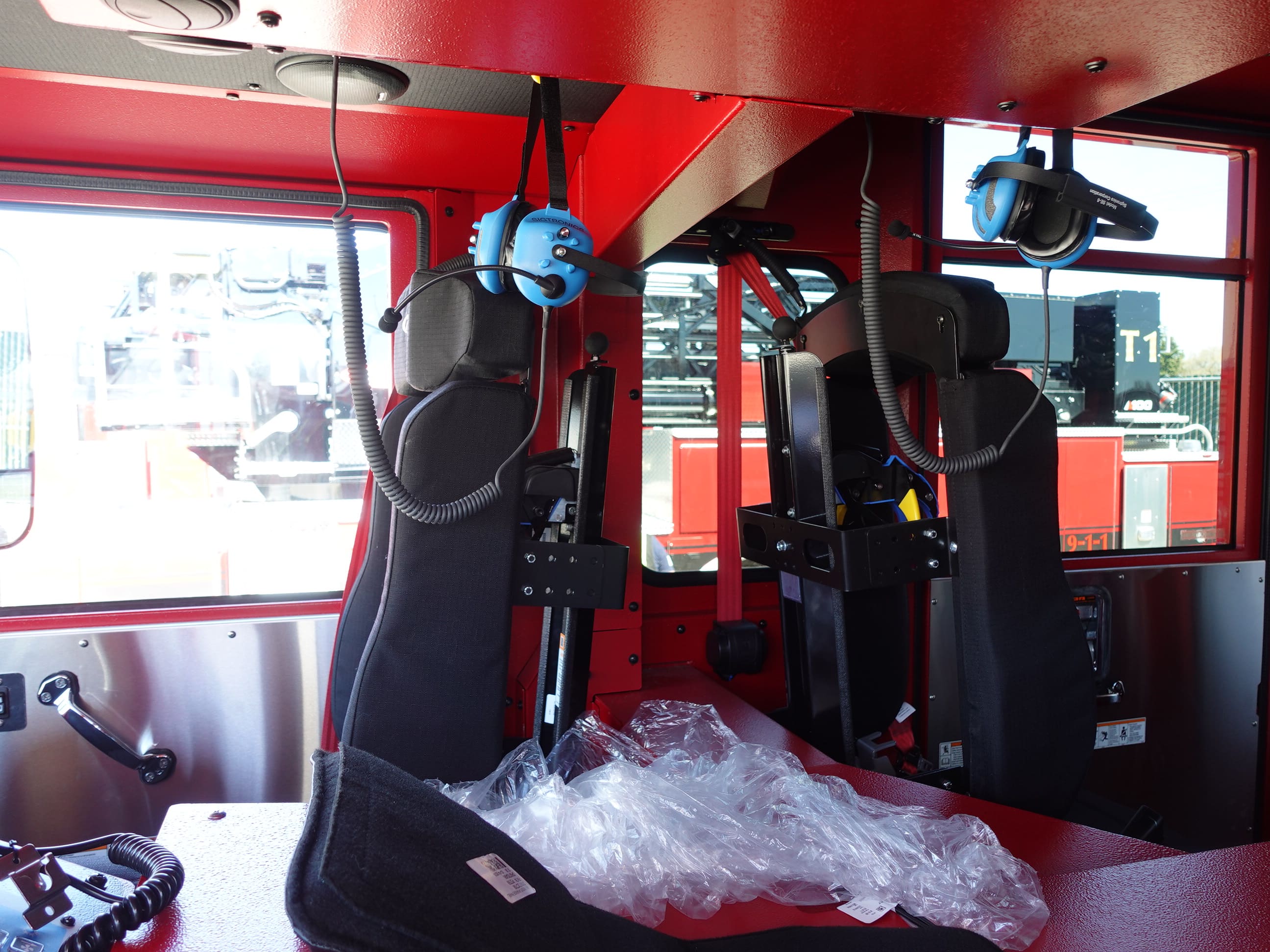

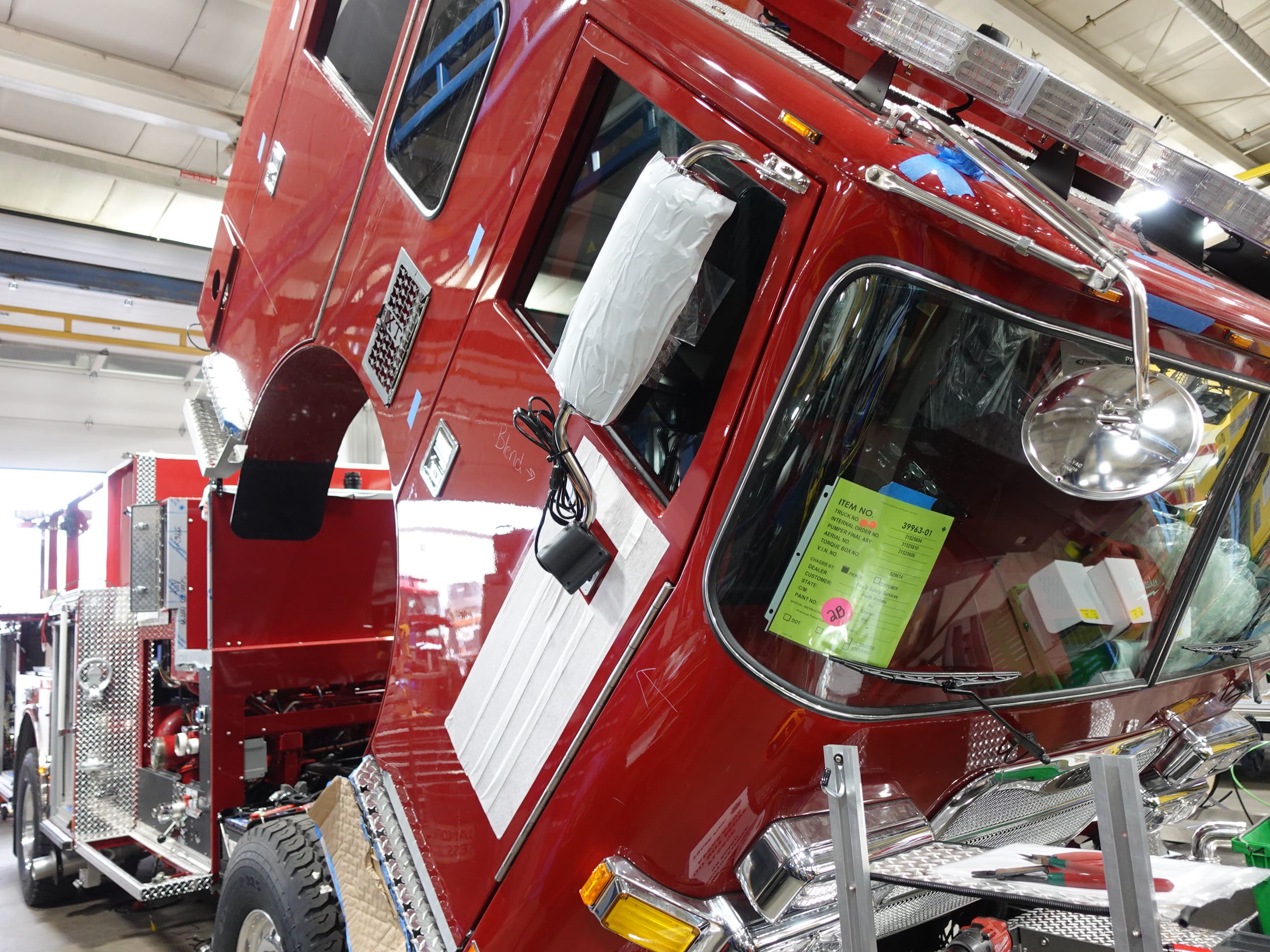

remaining content will be applied. Once finished it

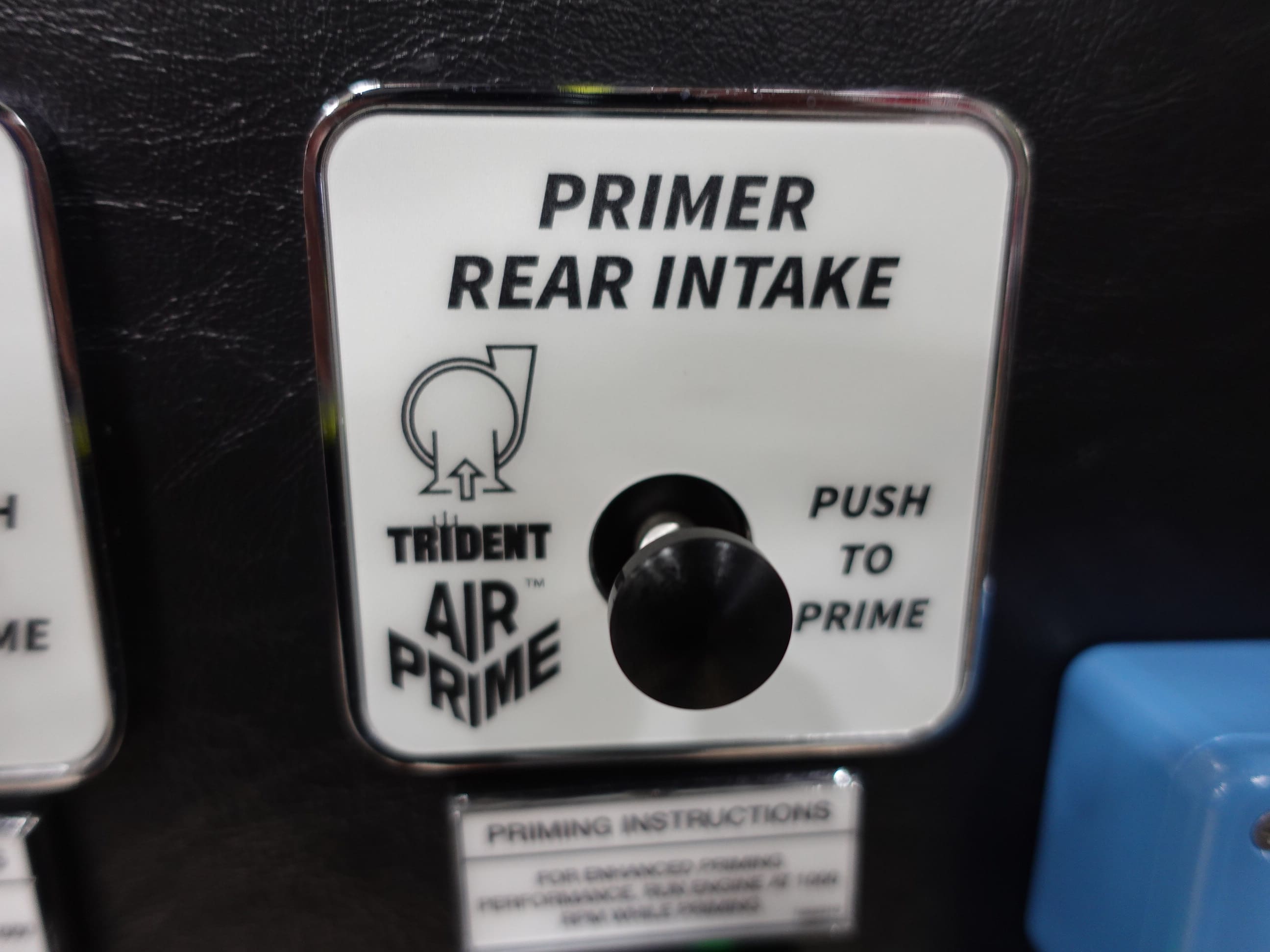

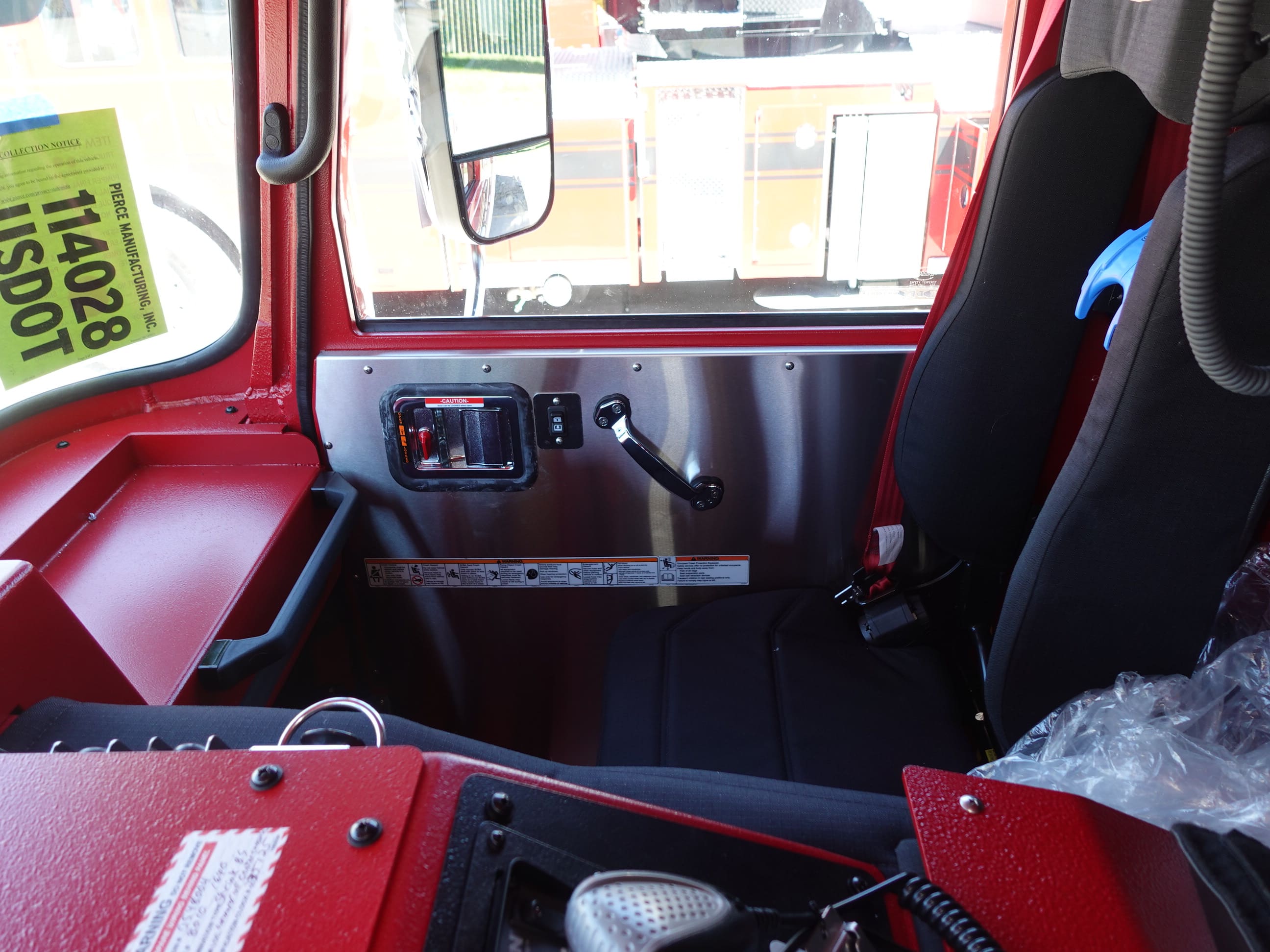

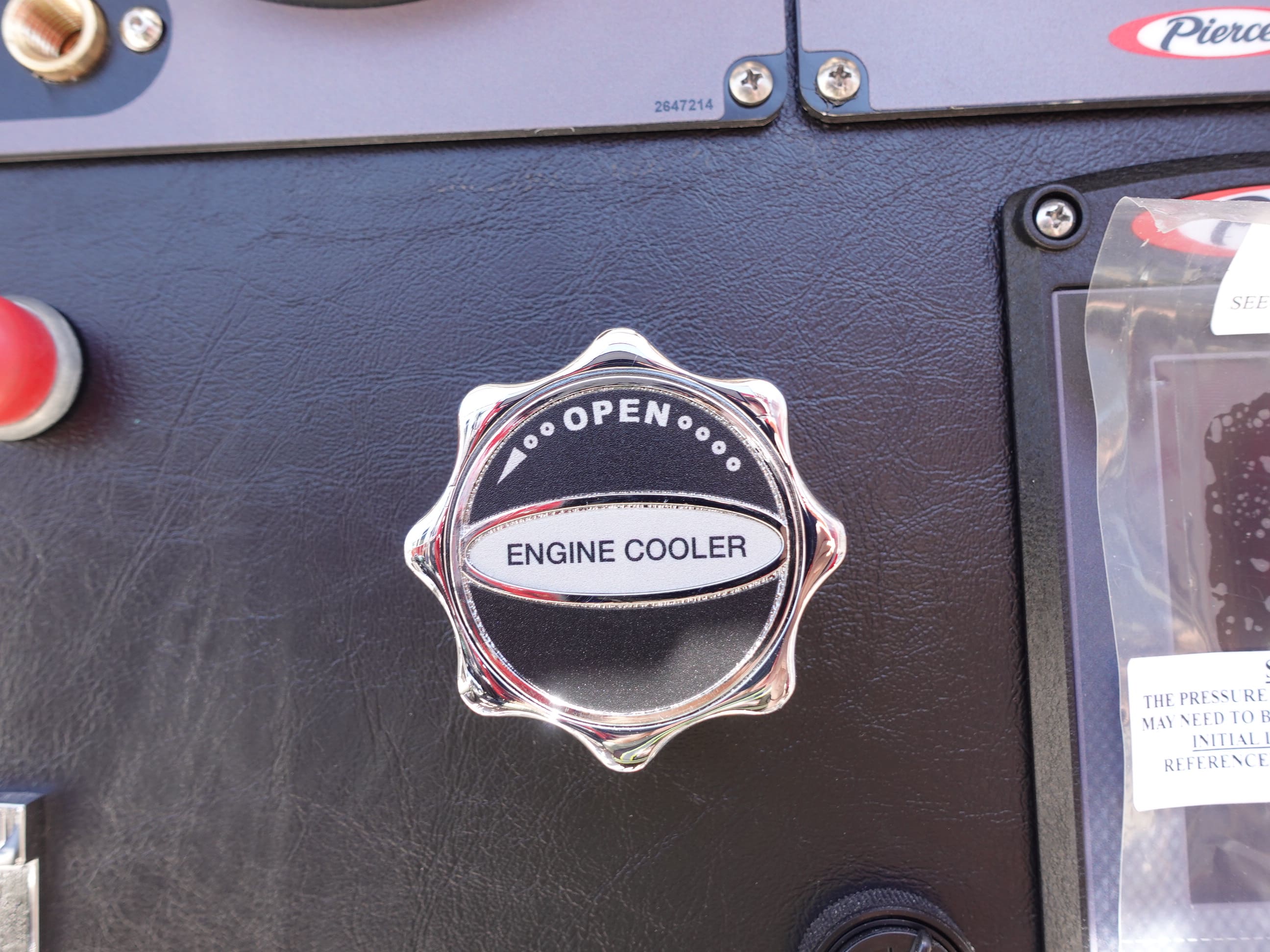

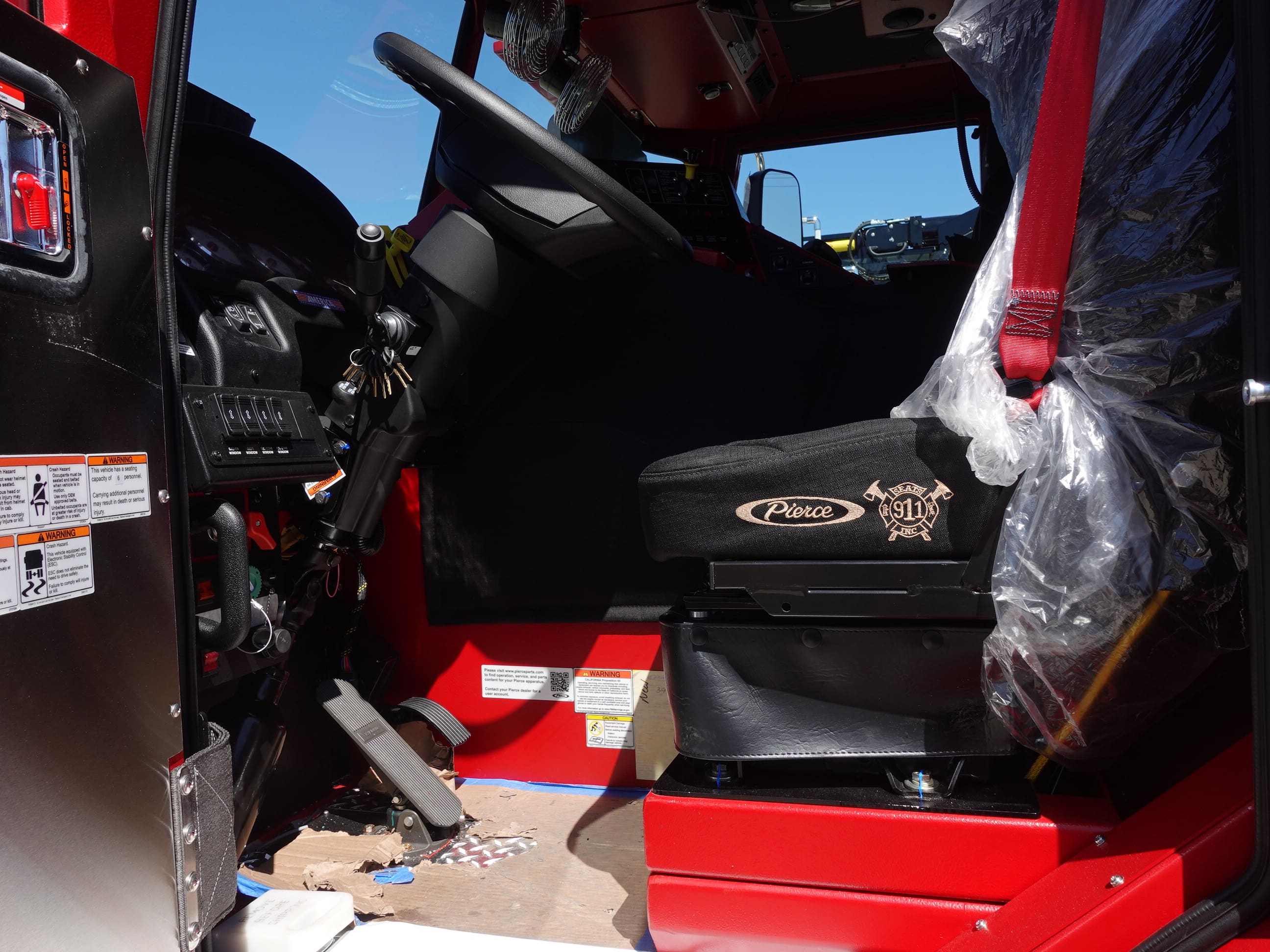

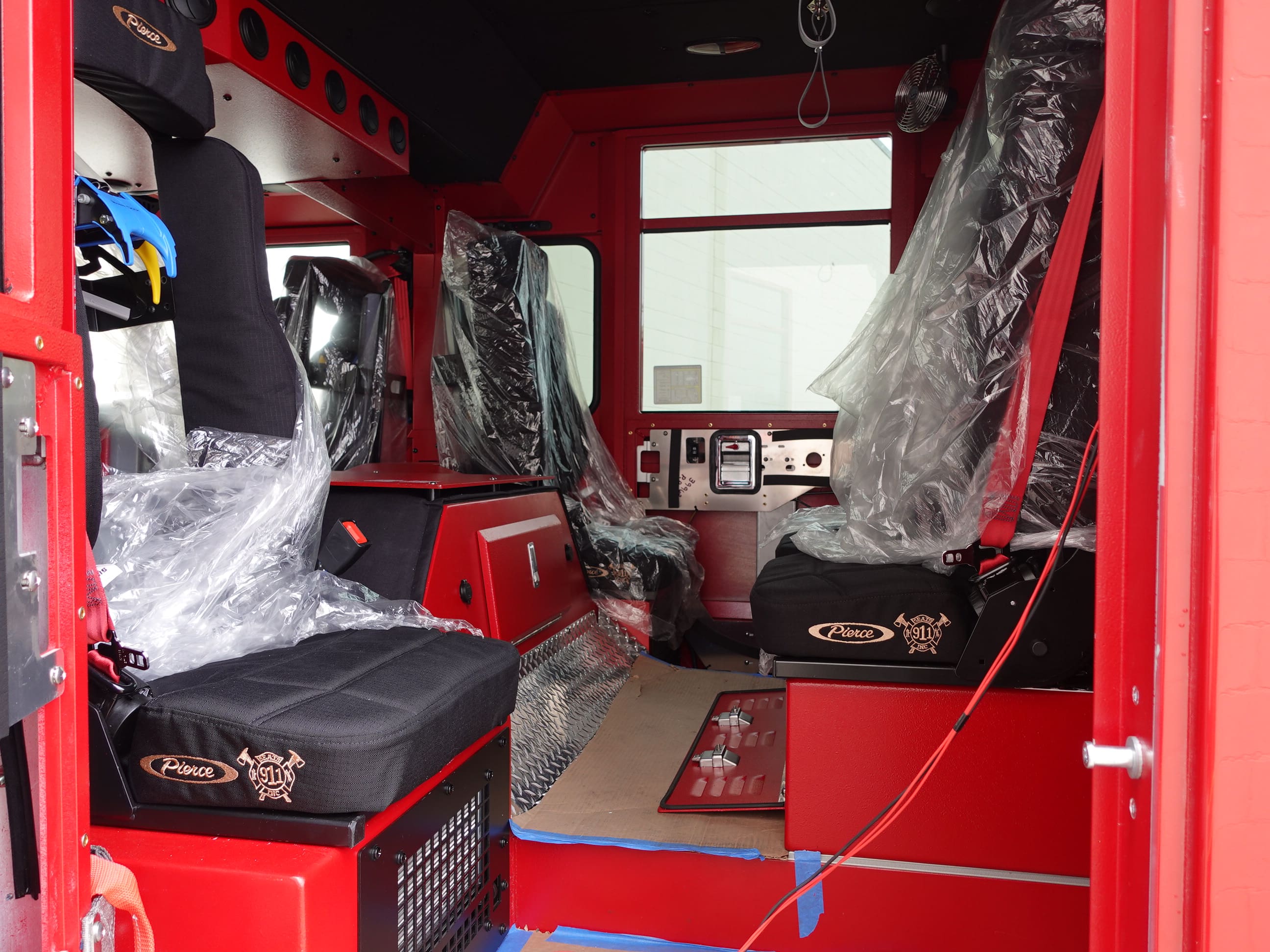

will be made ready for the customer acceptance
inspection. This is the last scheduled report.

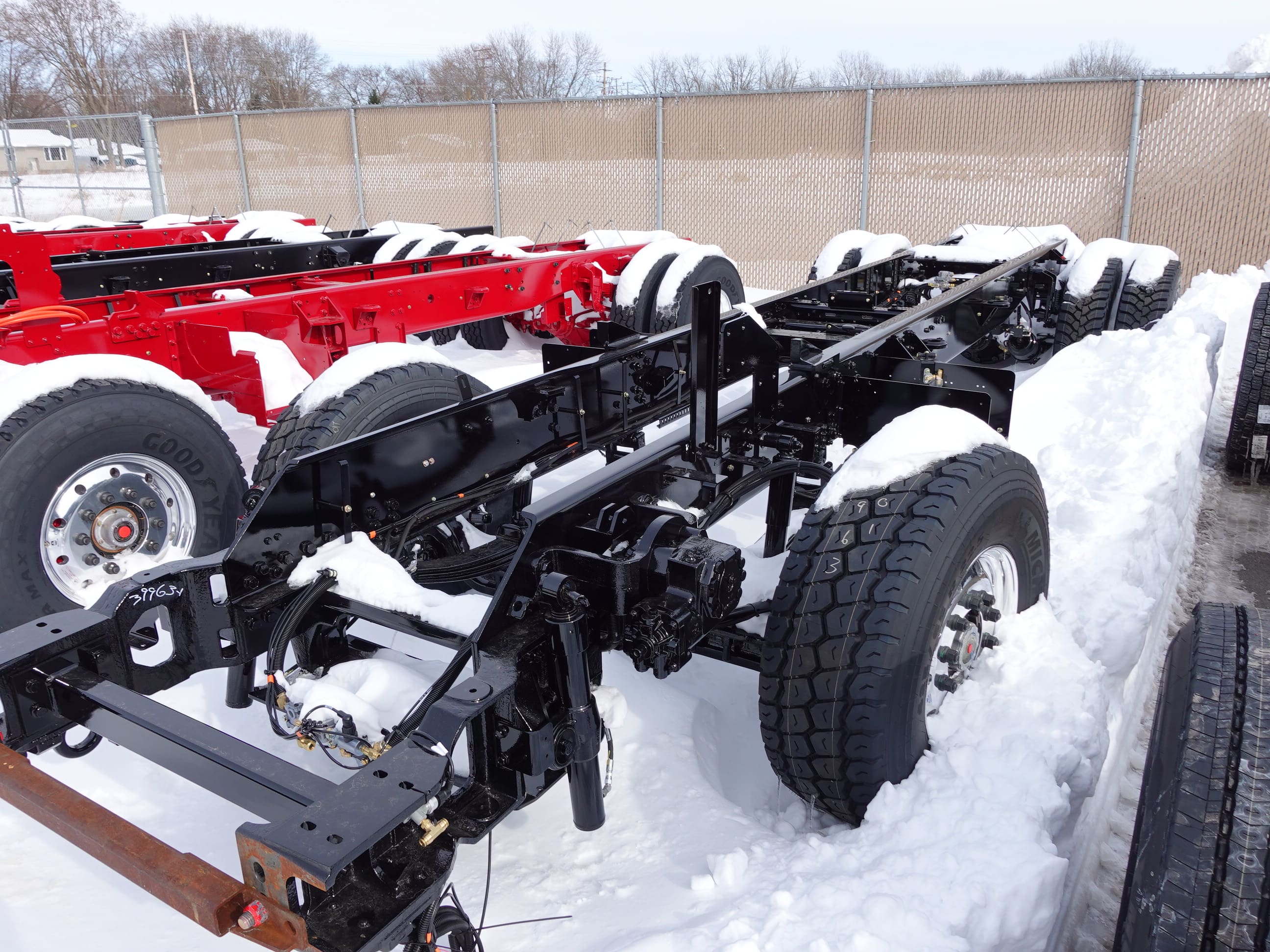

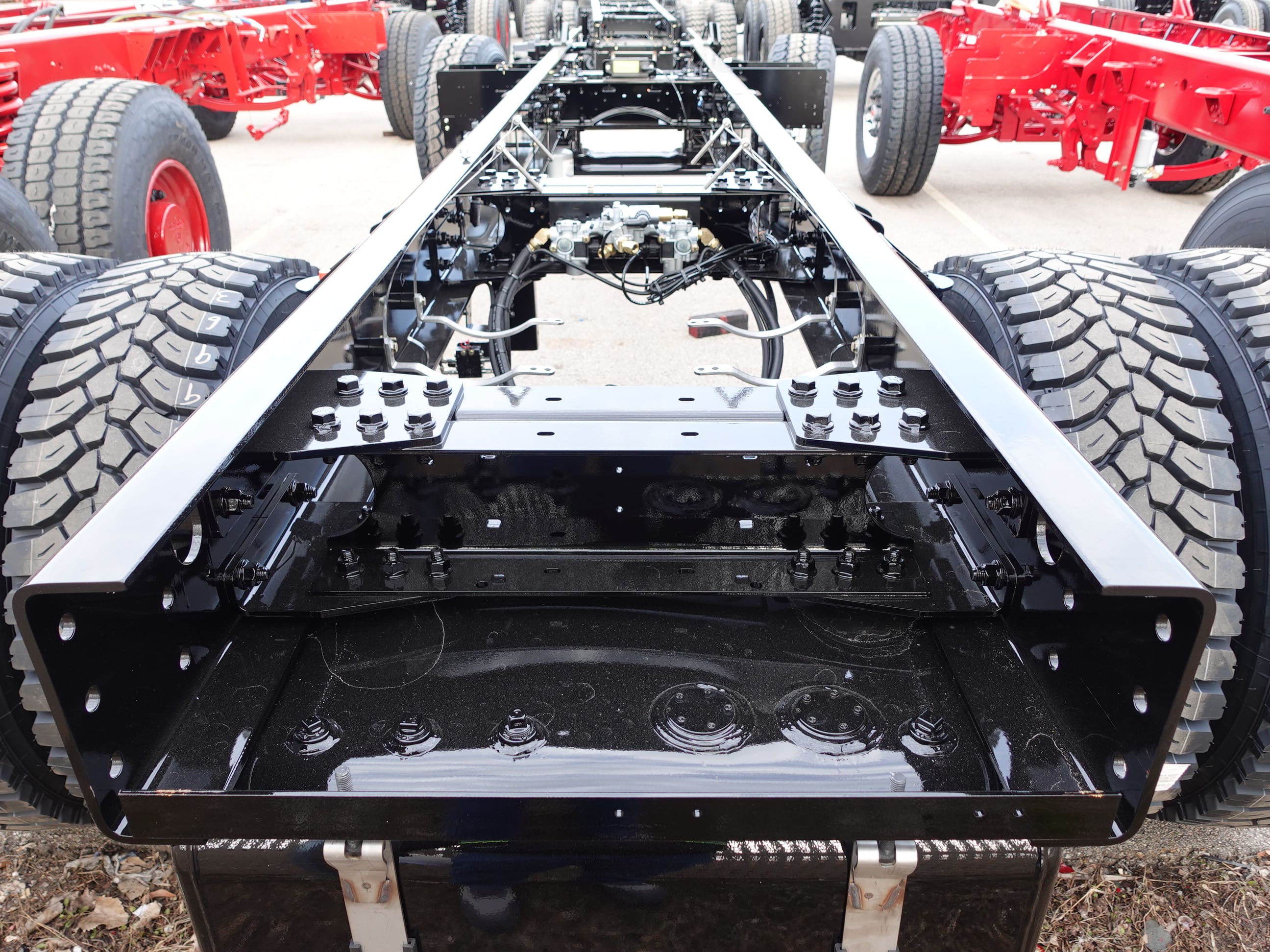

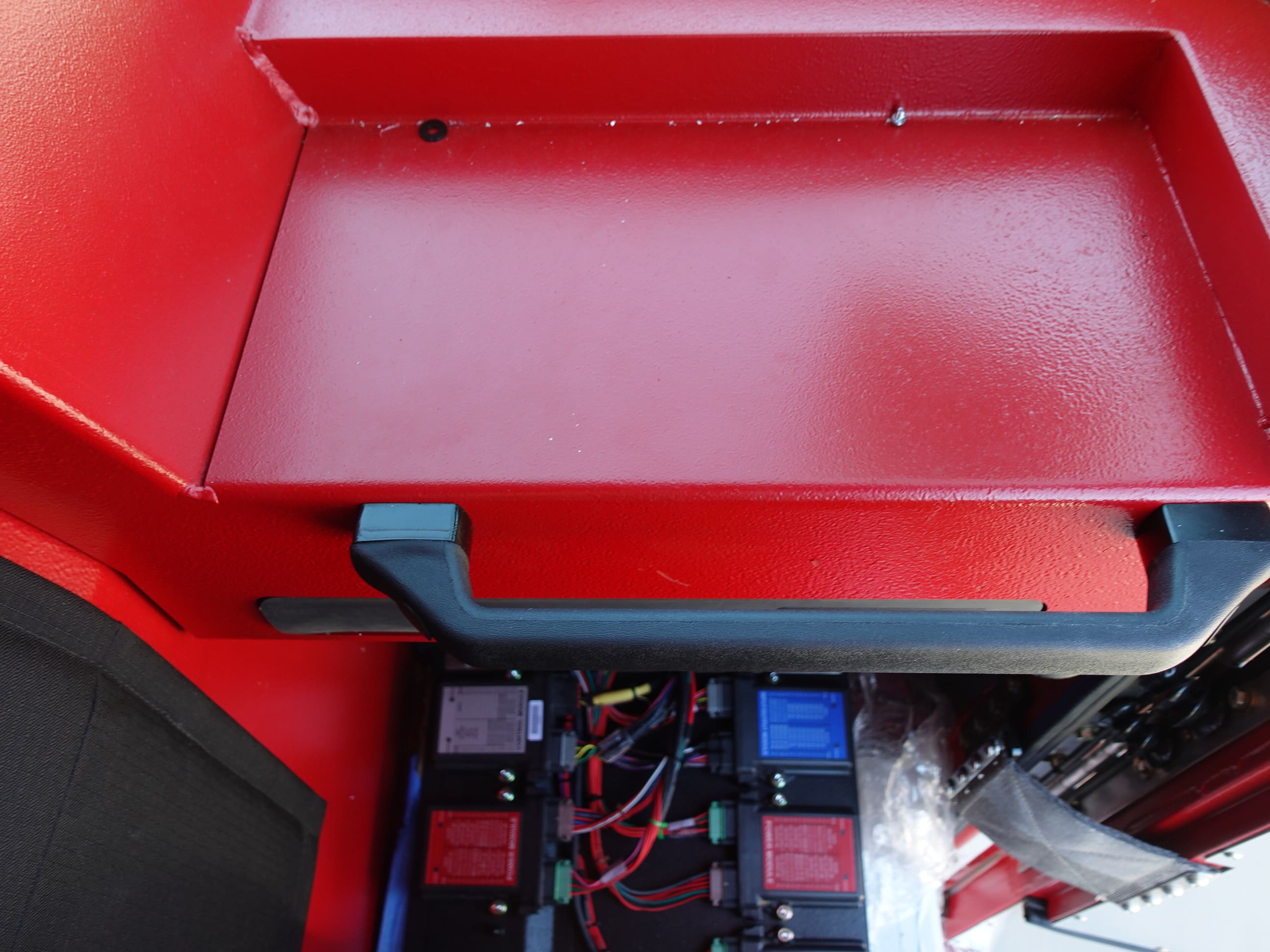

04-03-26

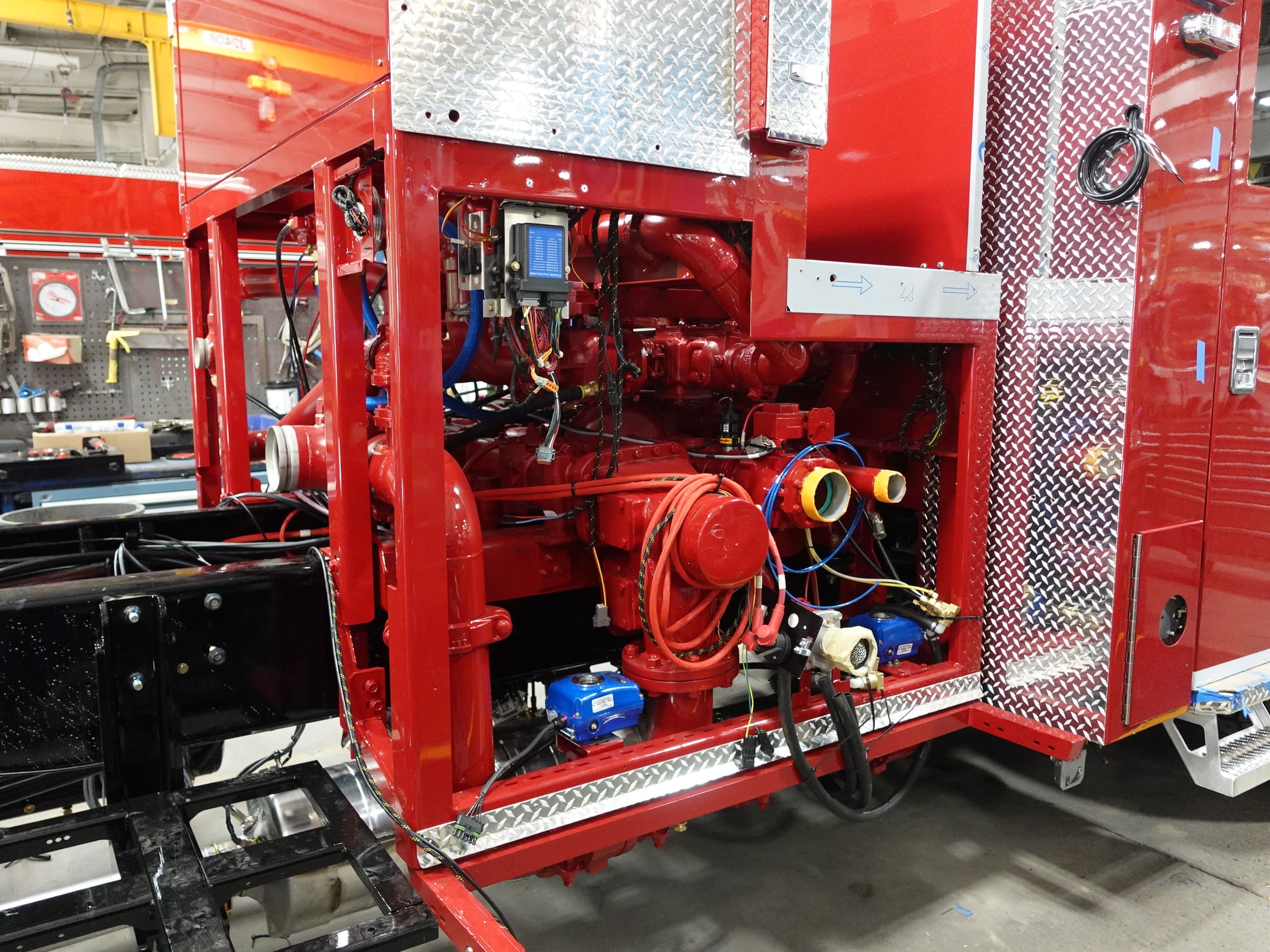

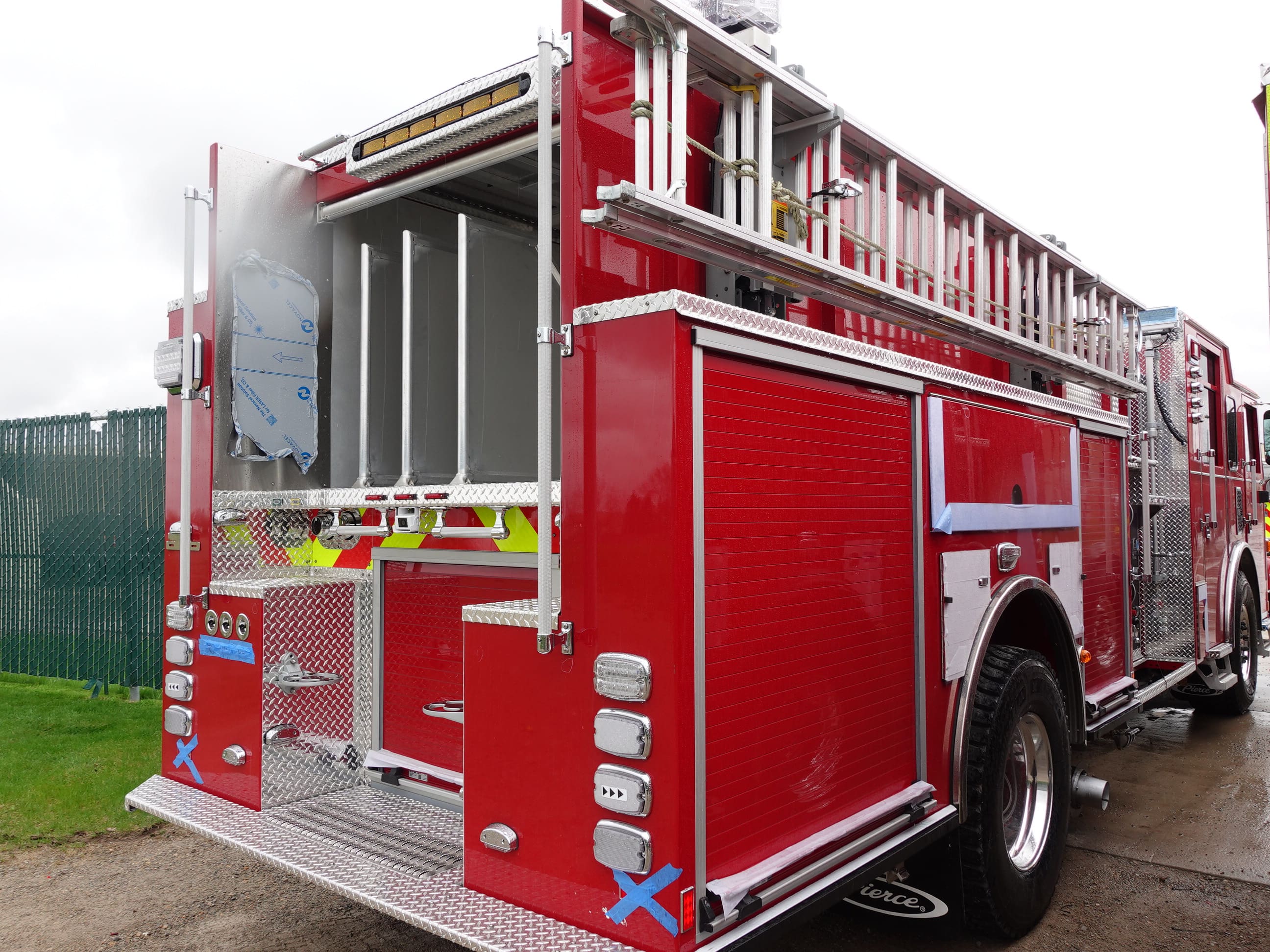

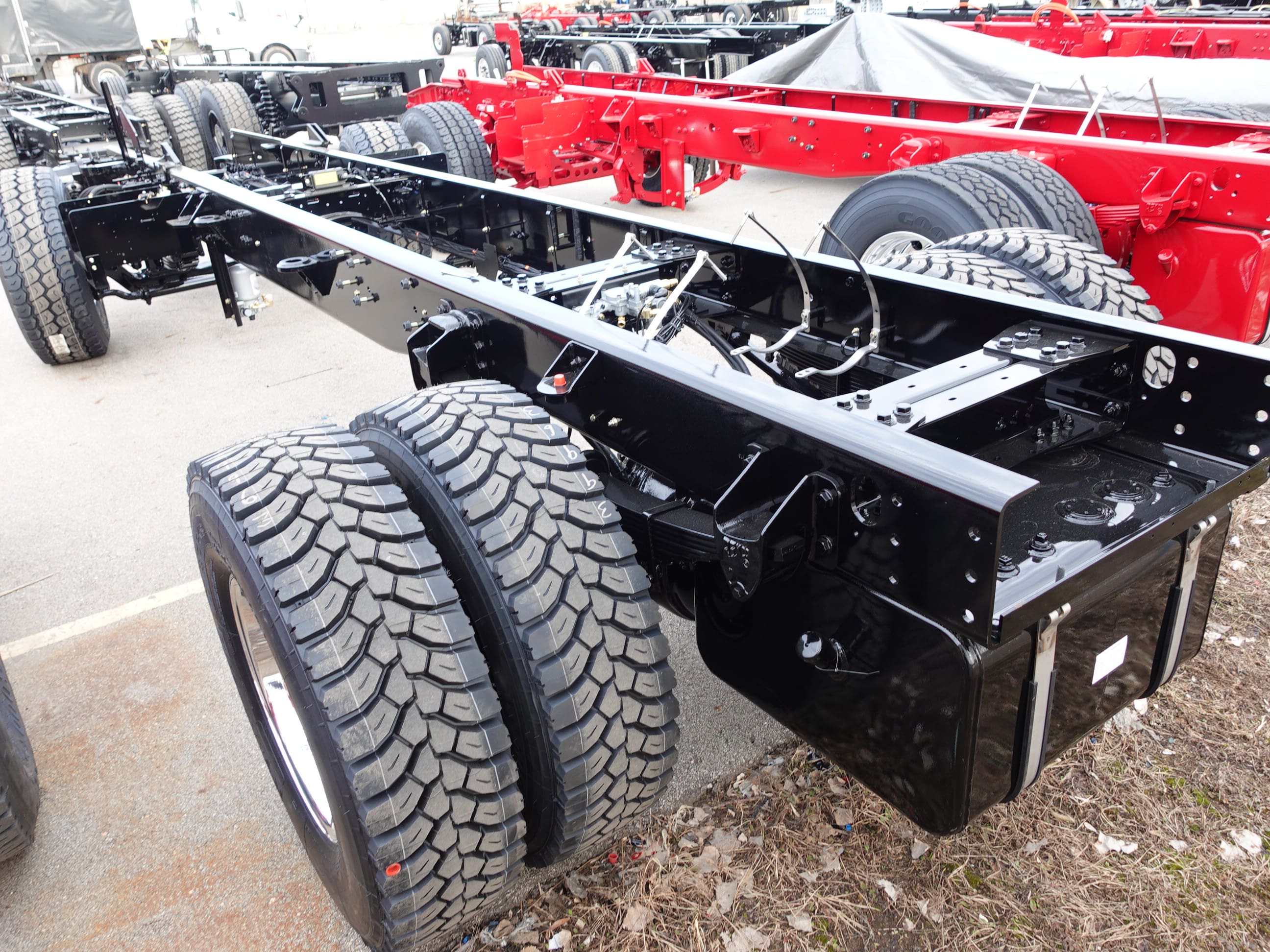

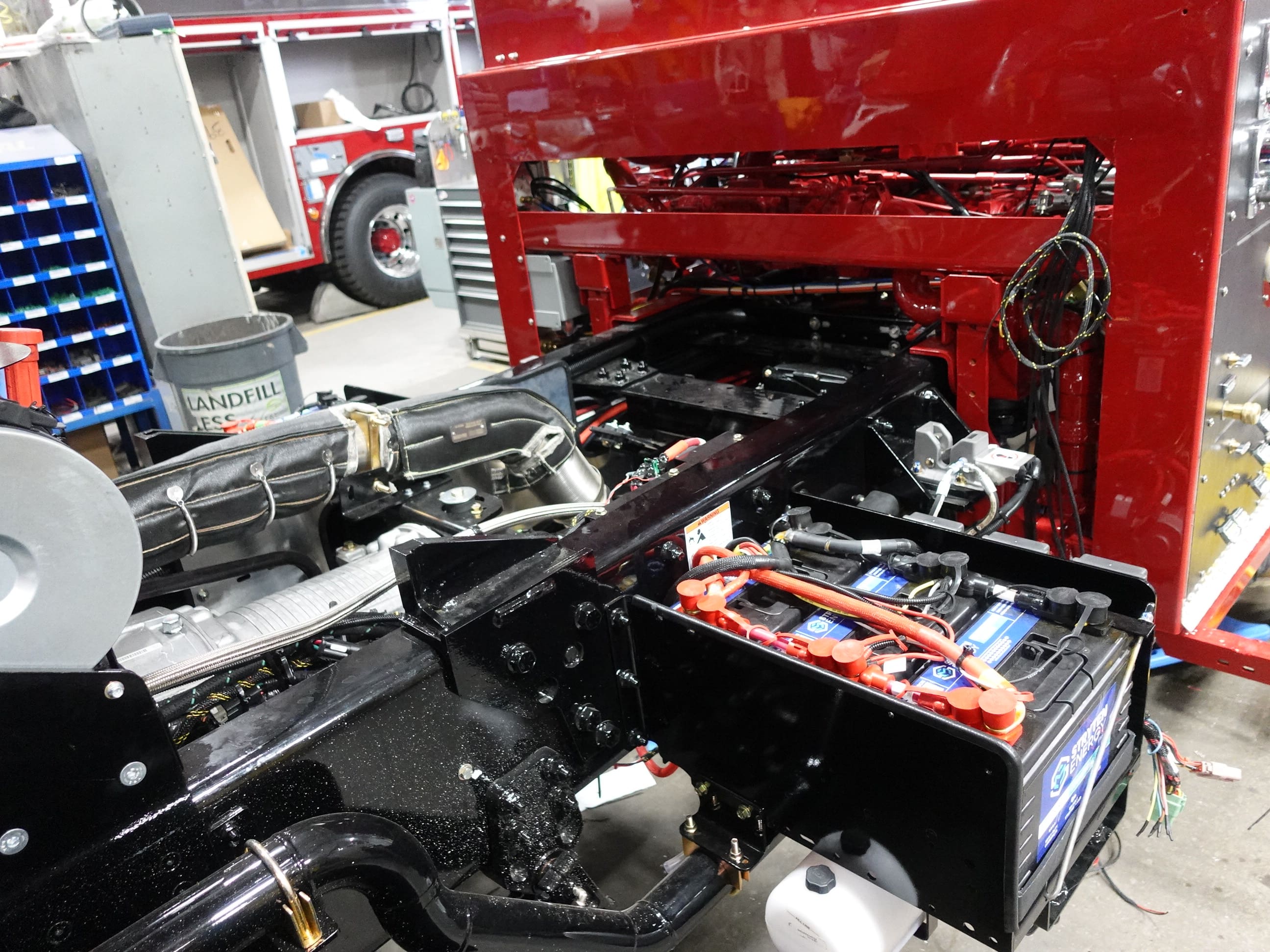

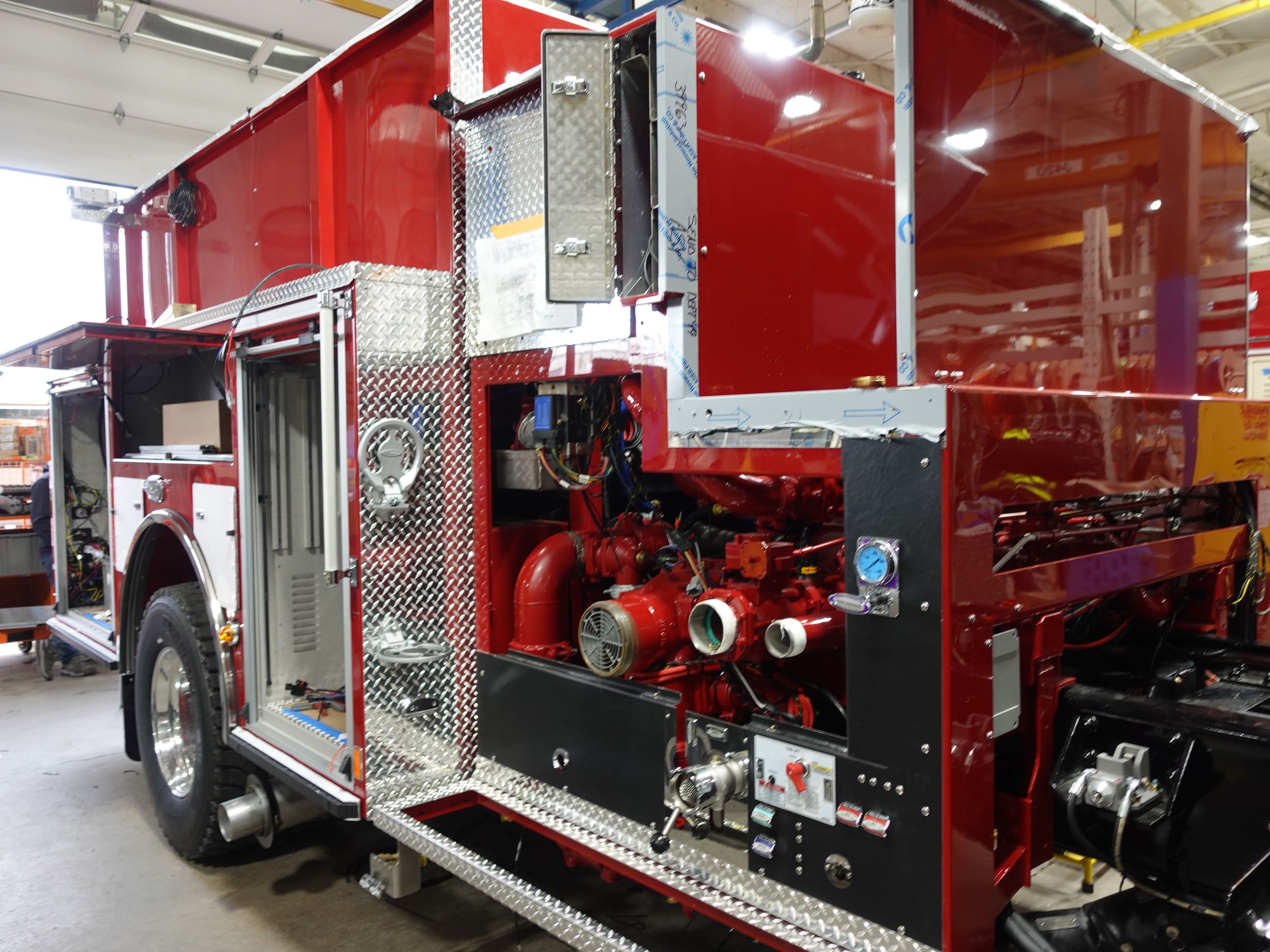

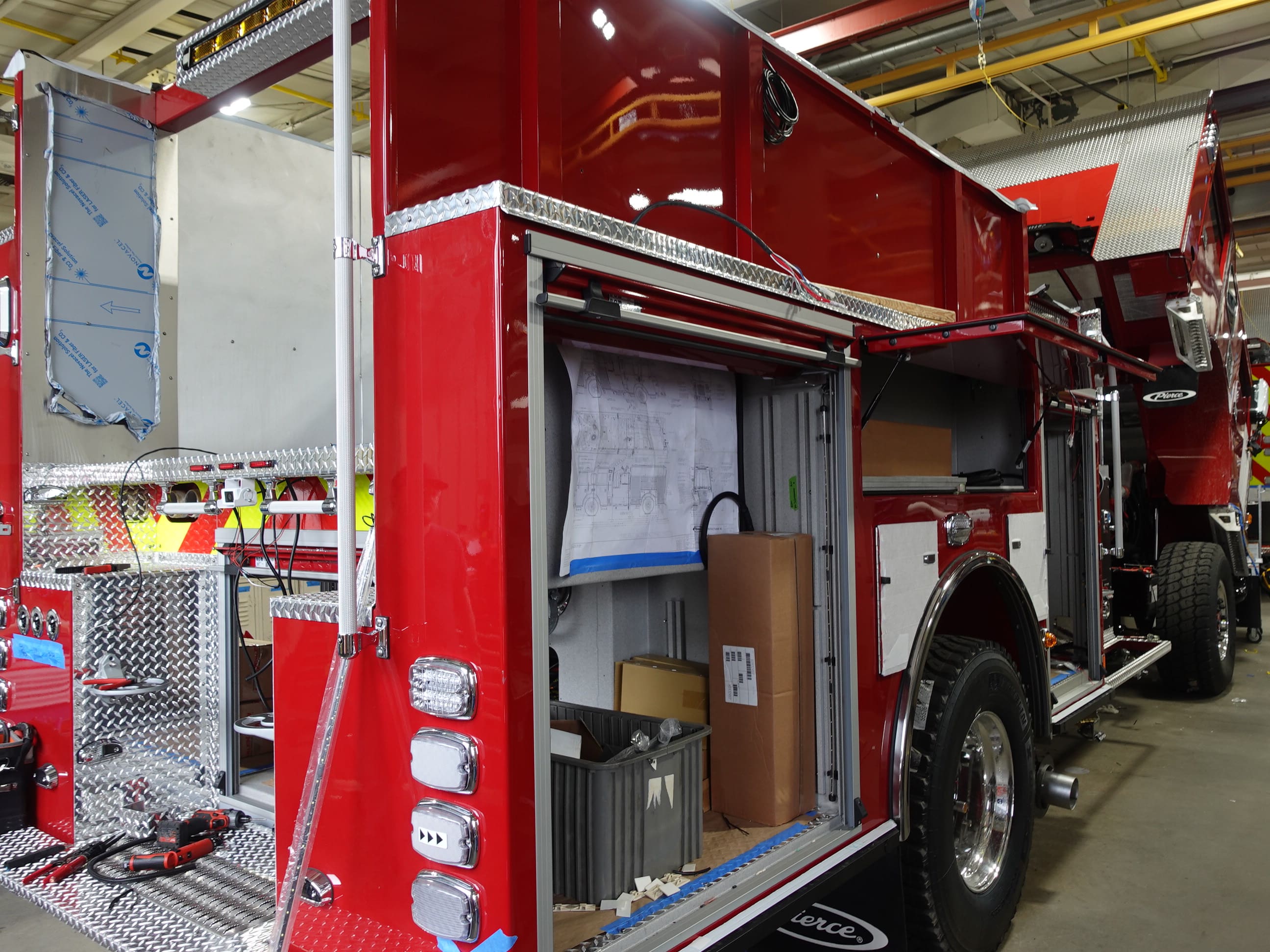

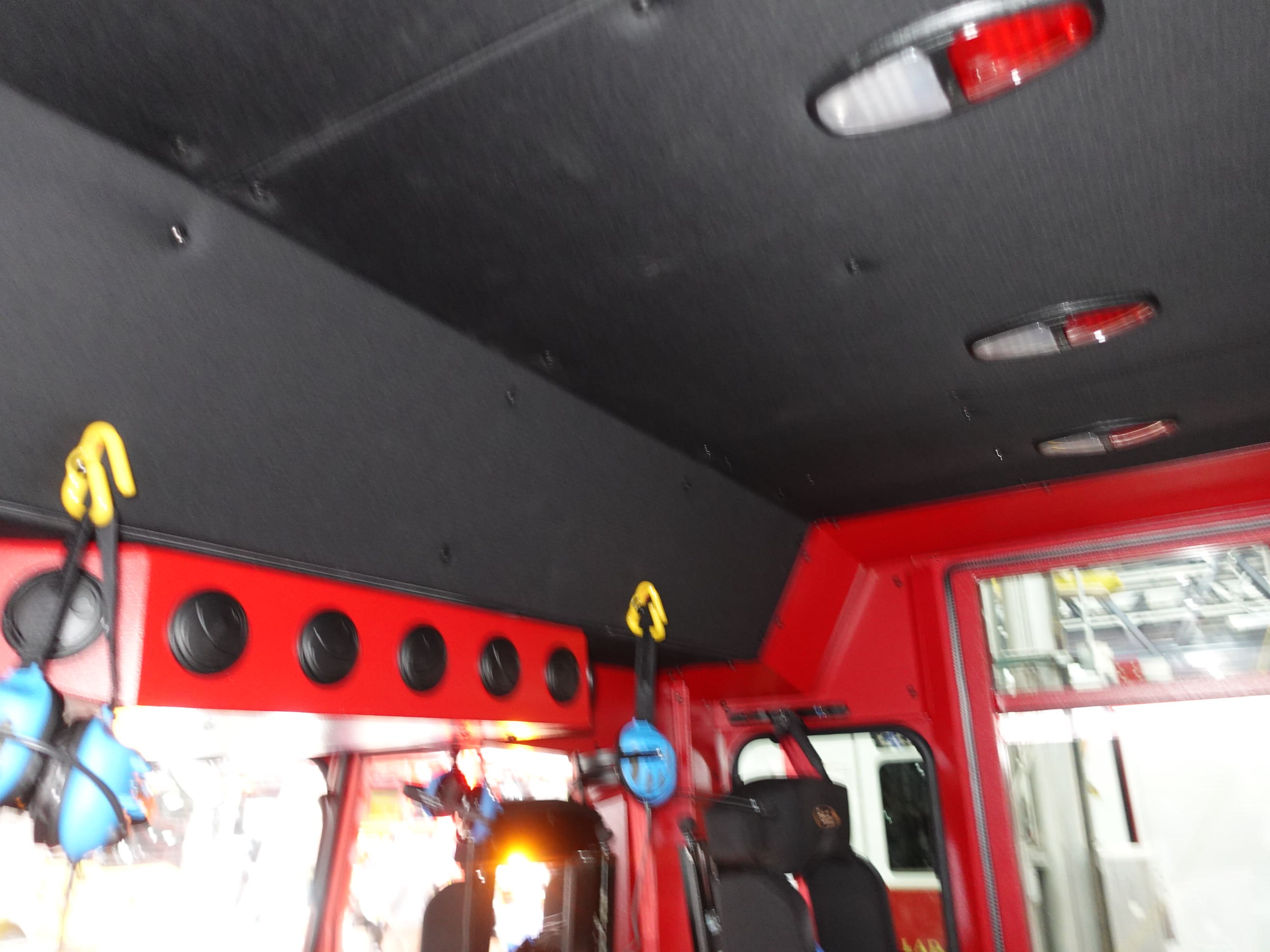

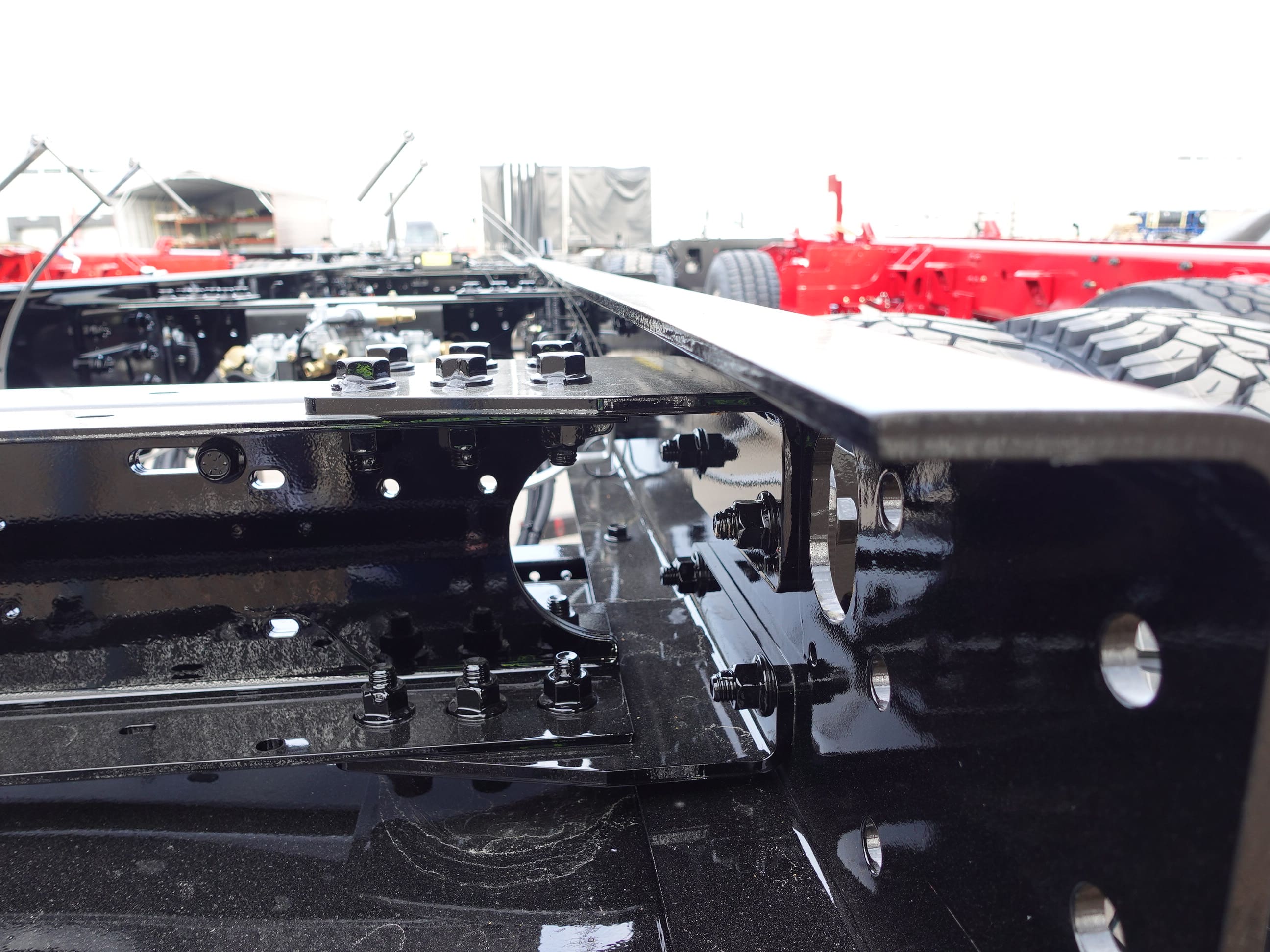

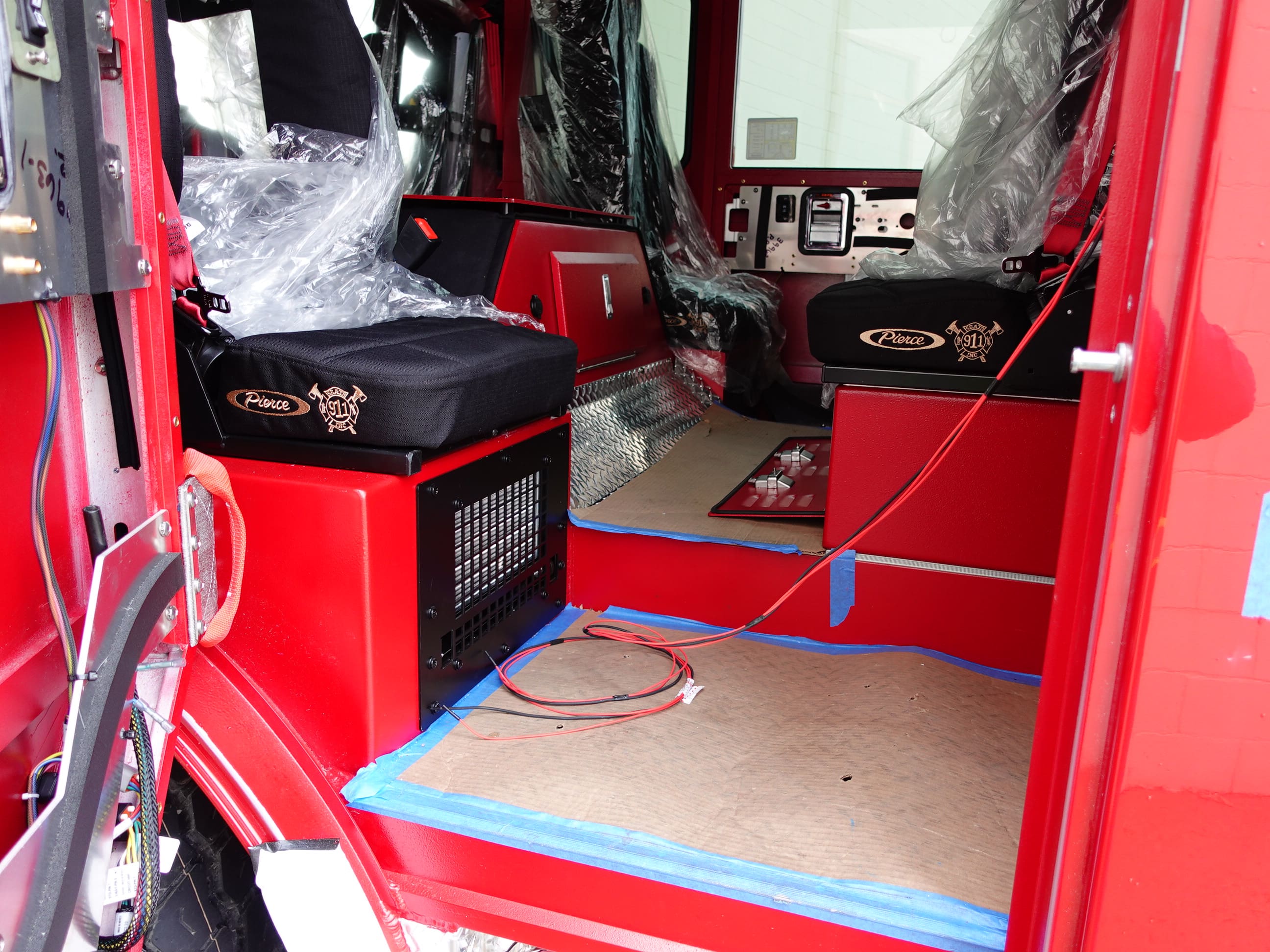

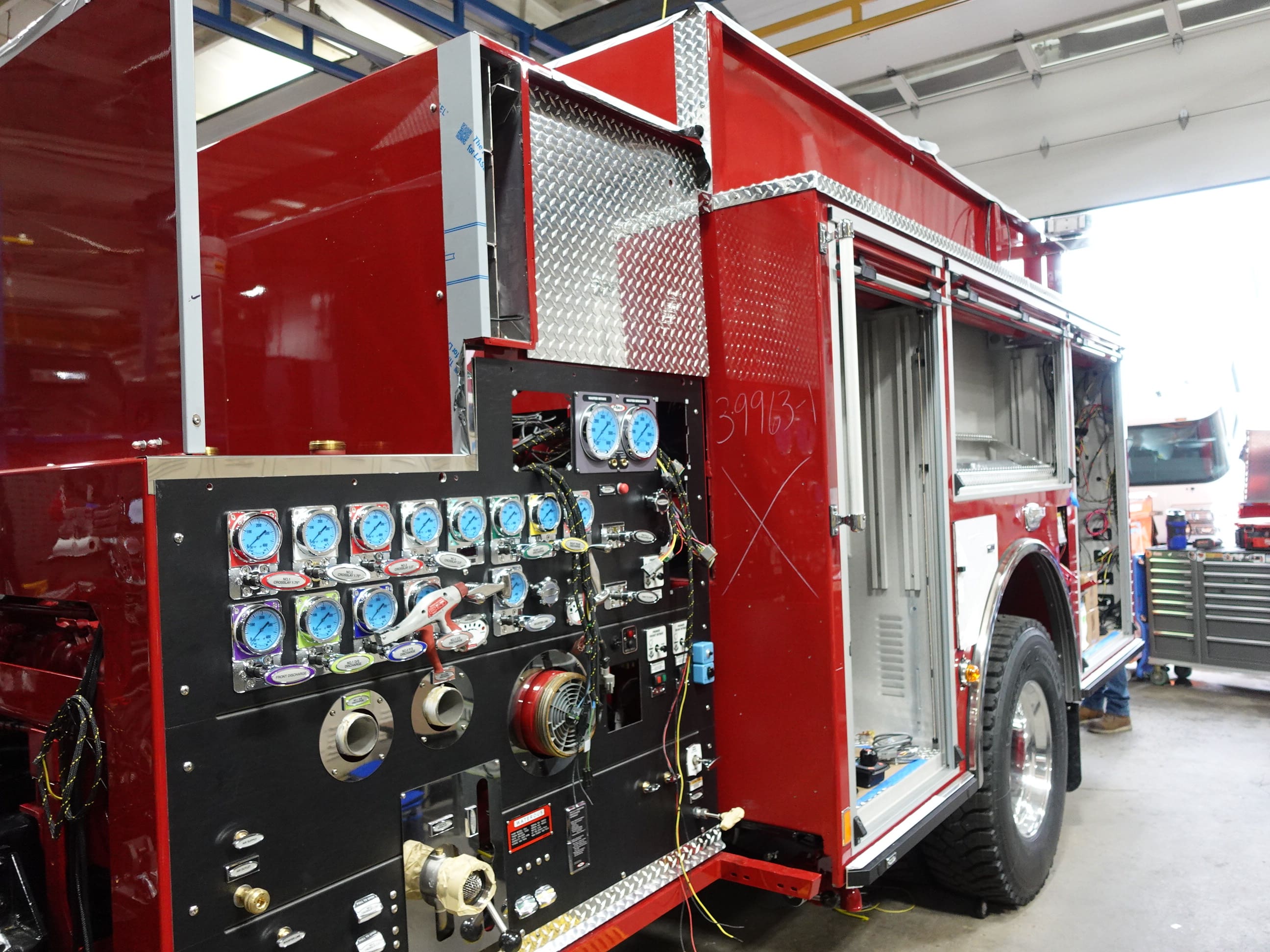

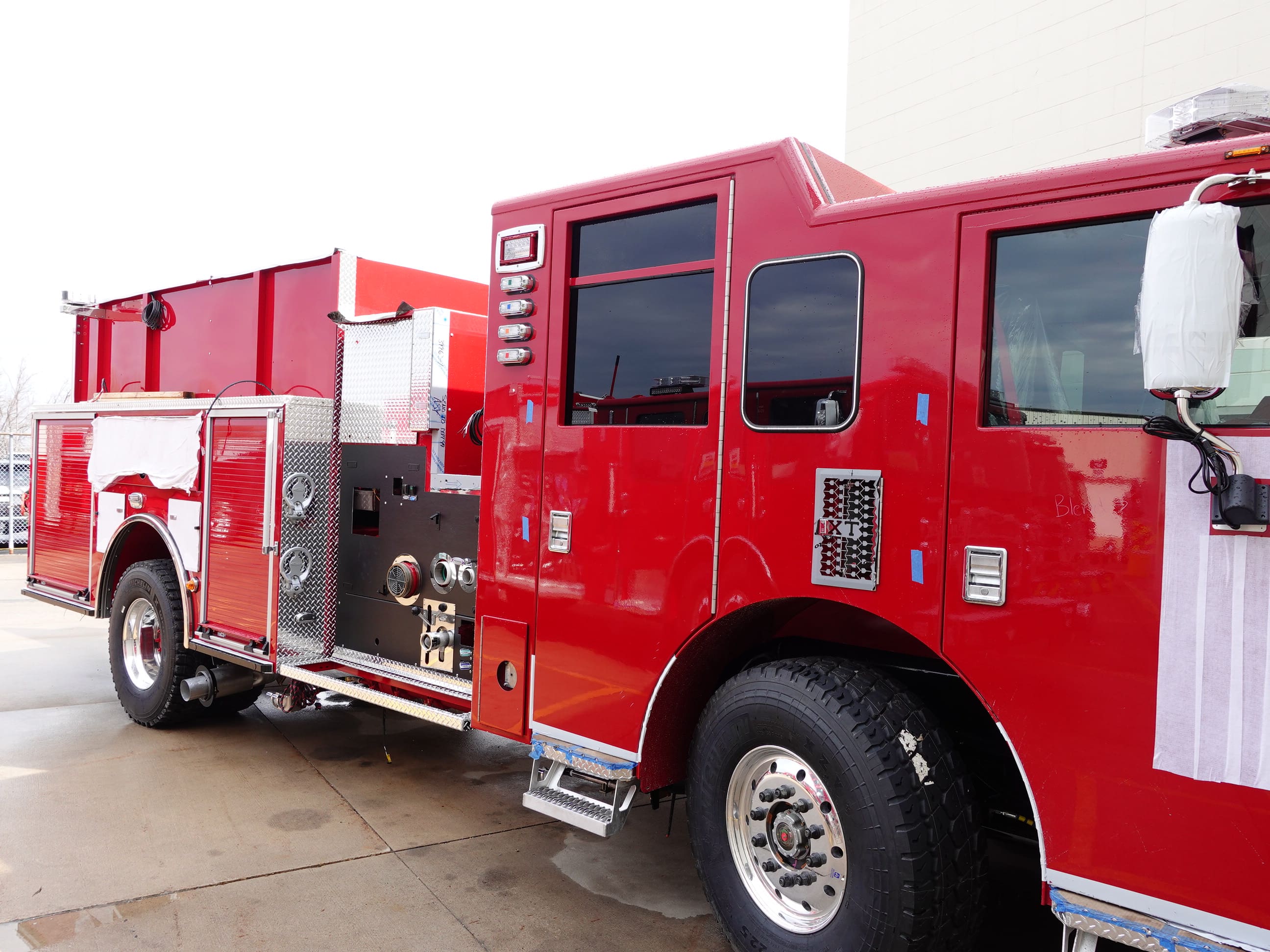

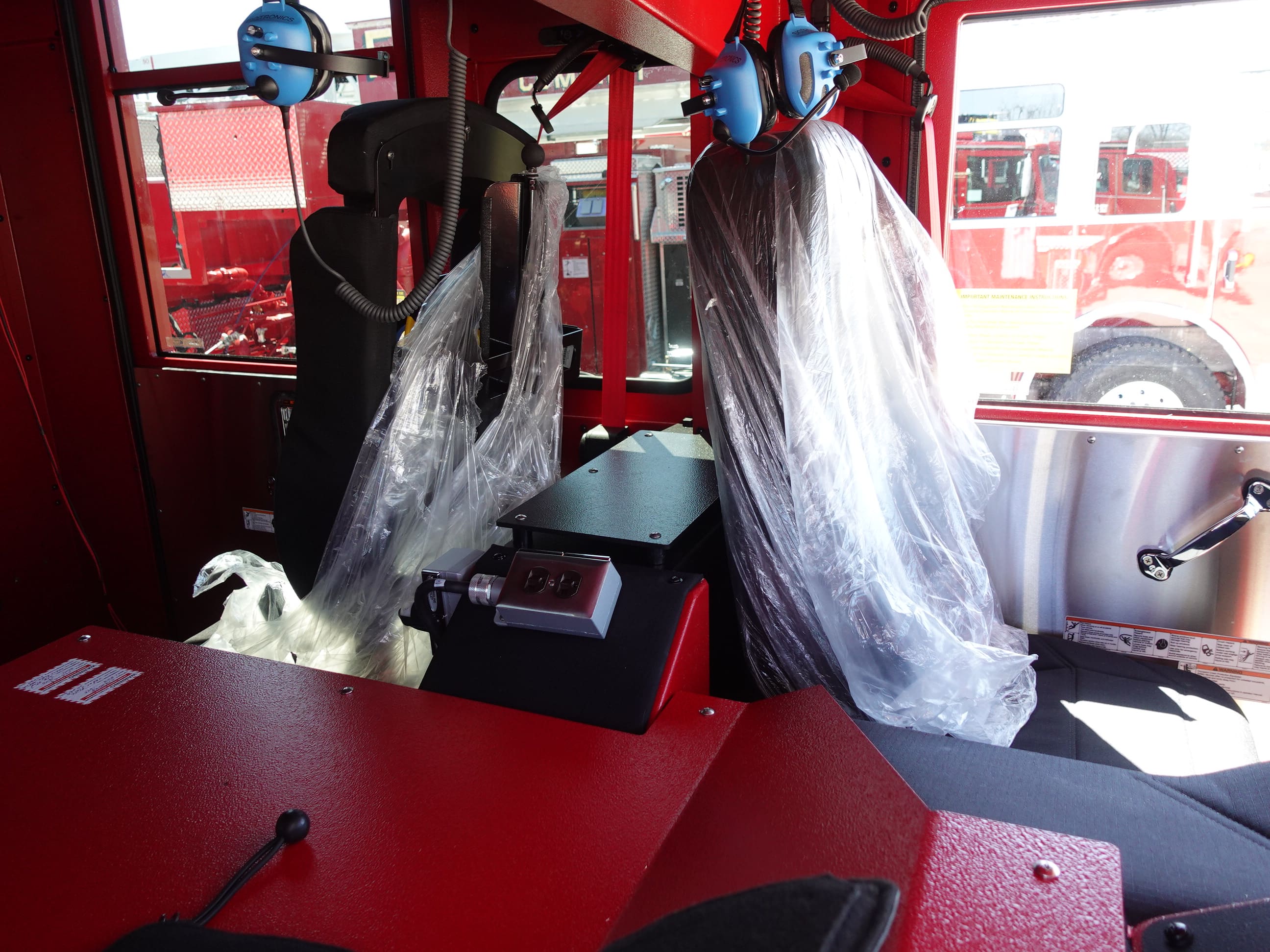

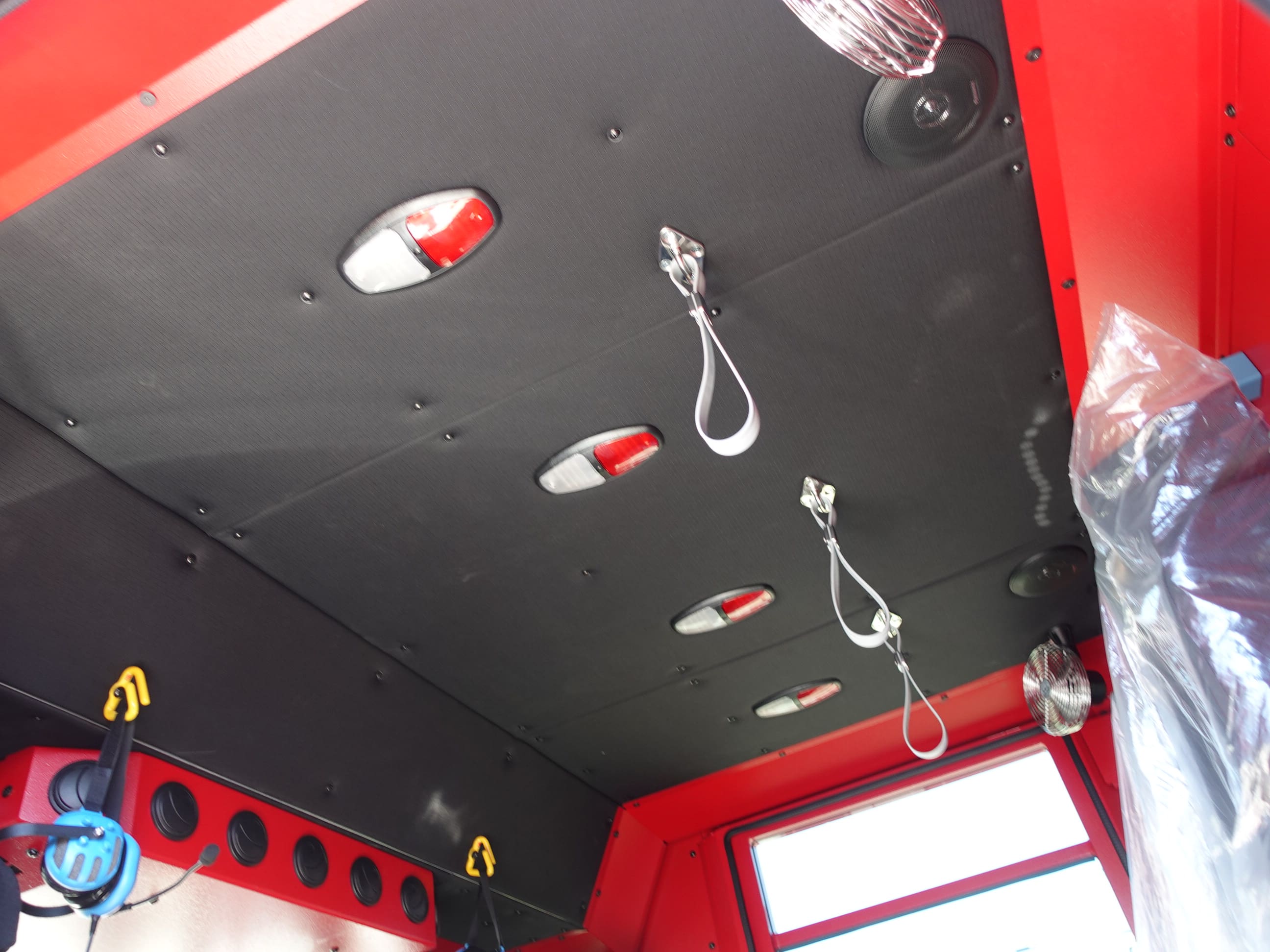

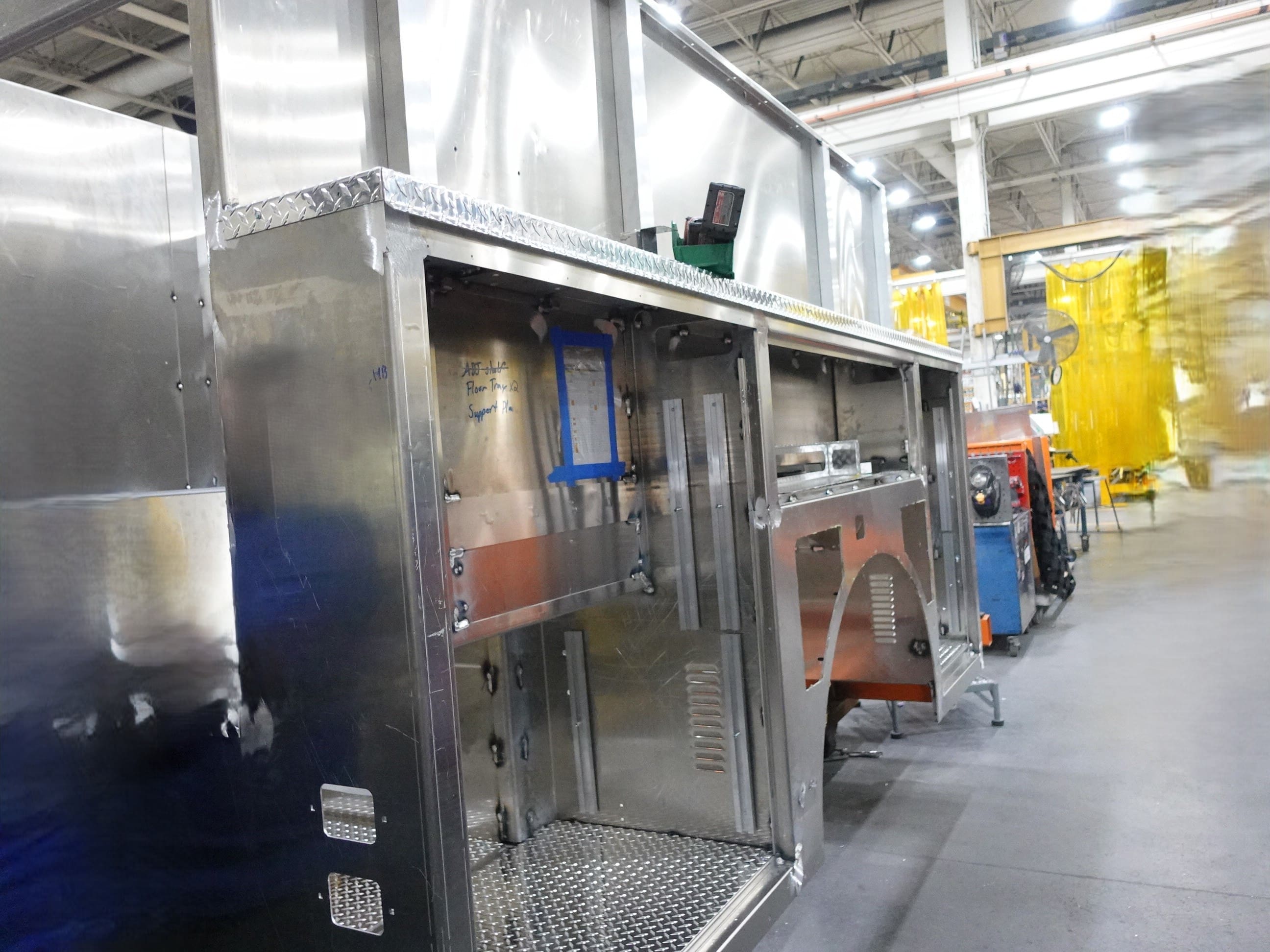

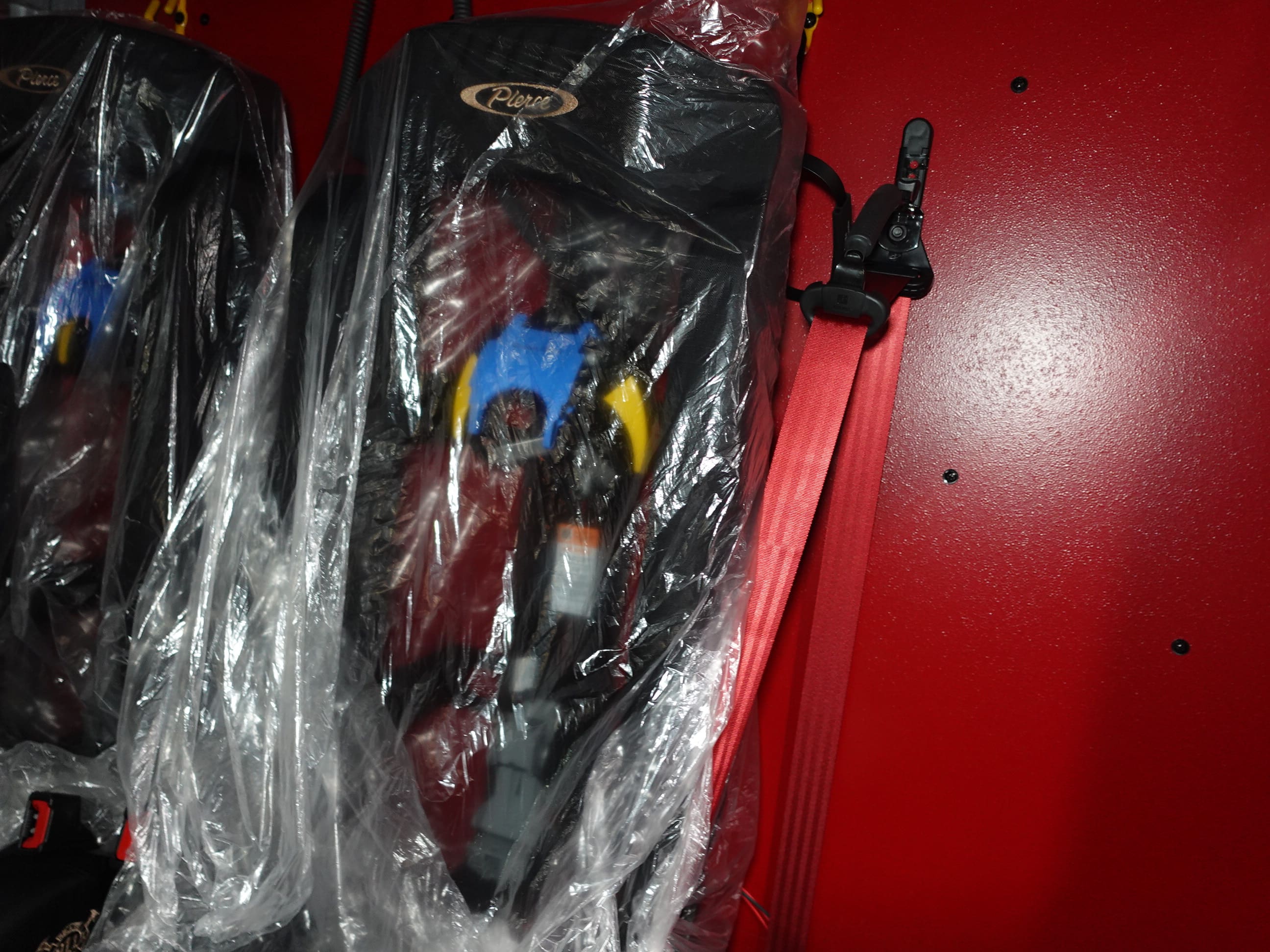

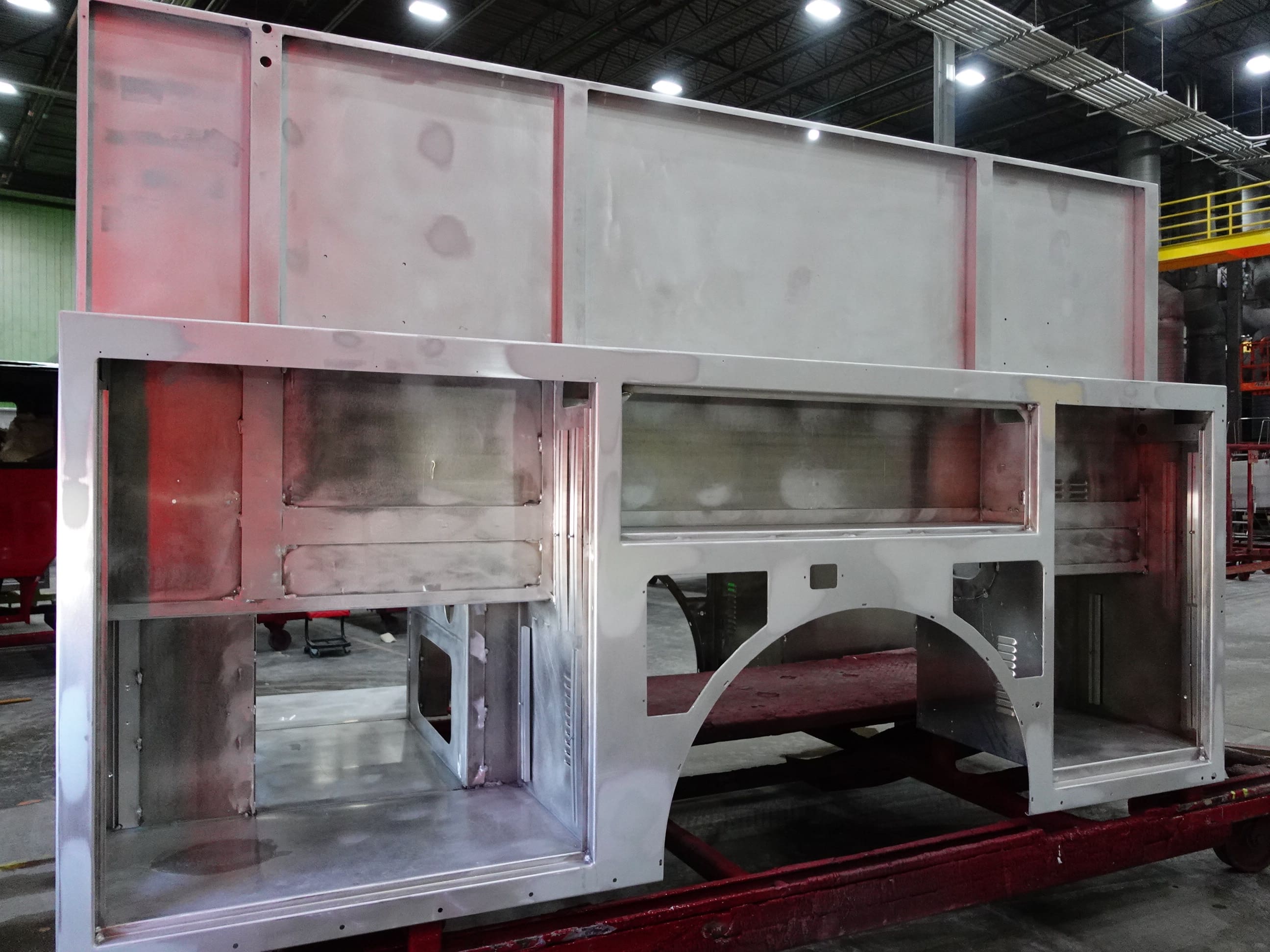

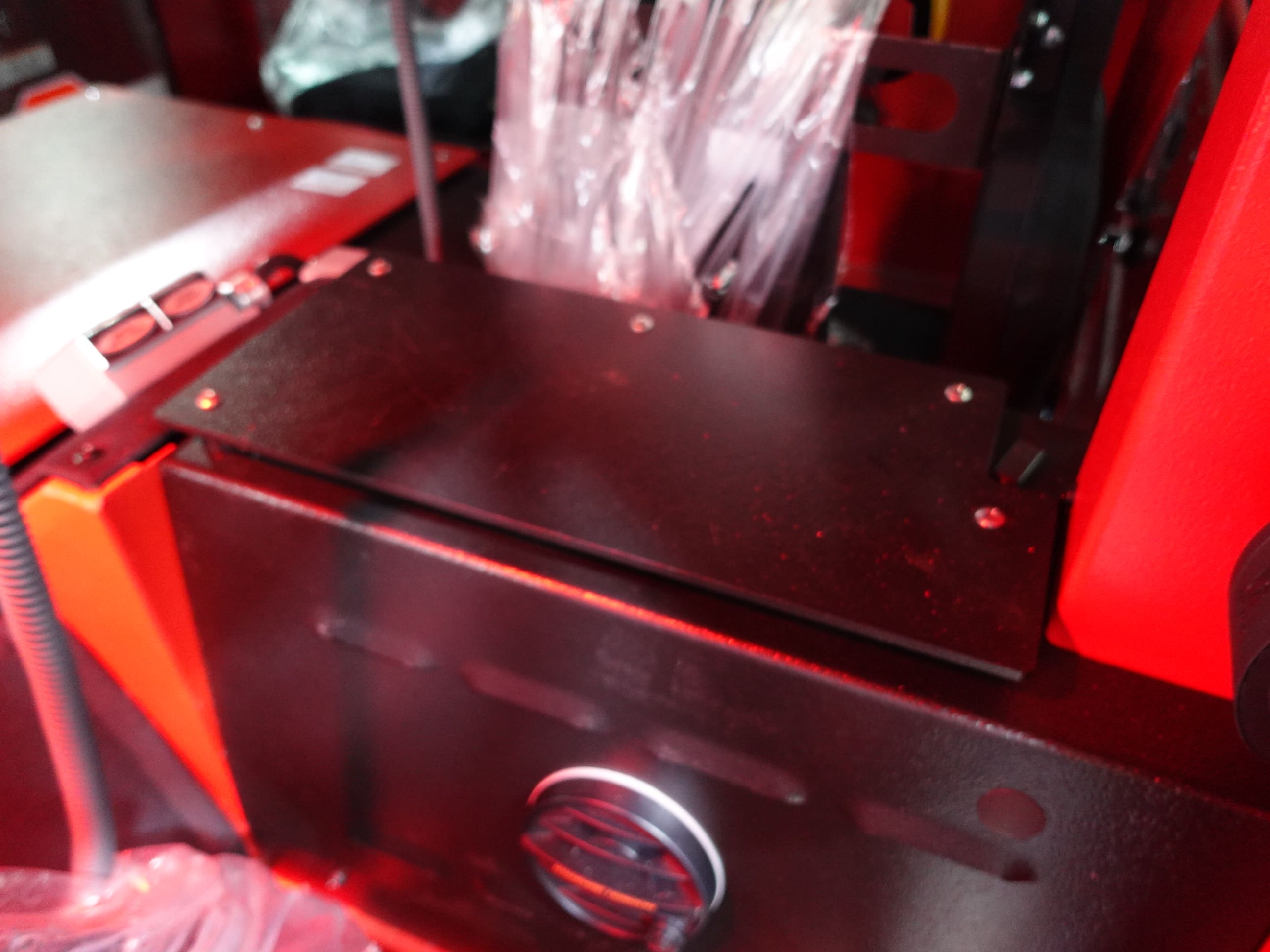

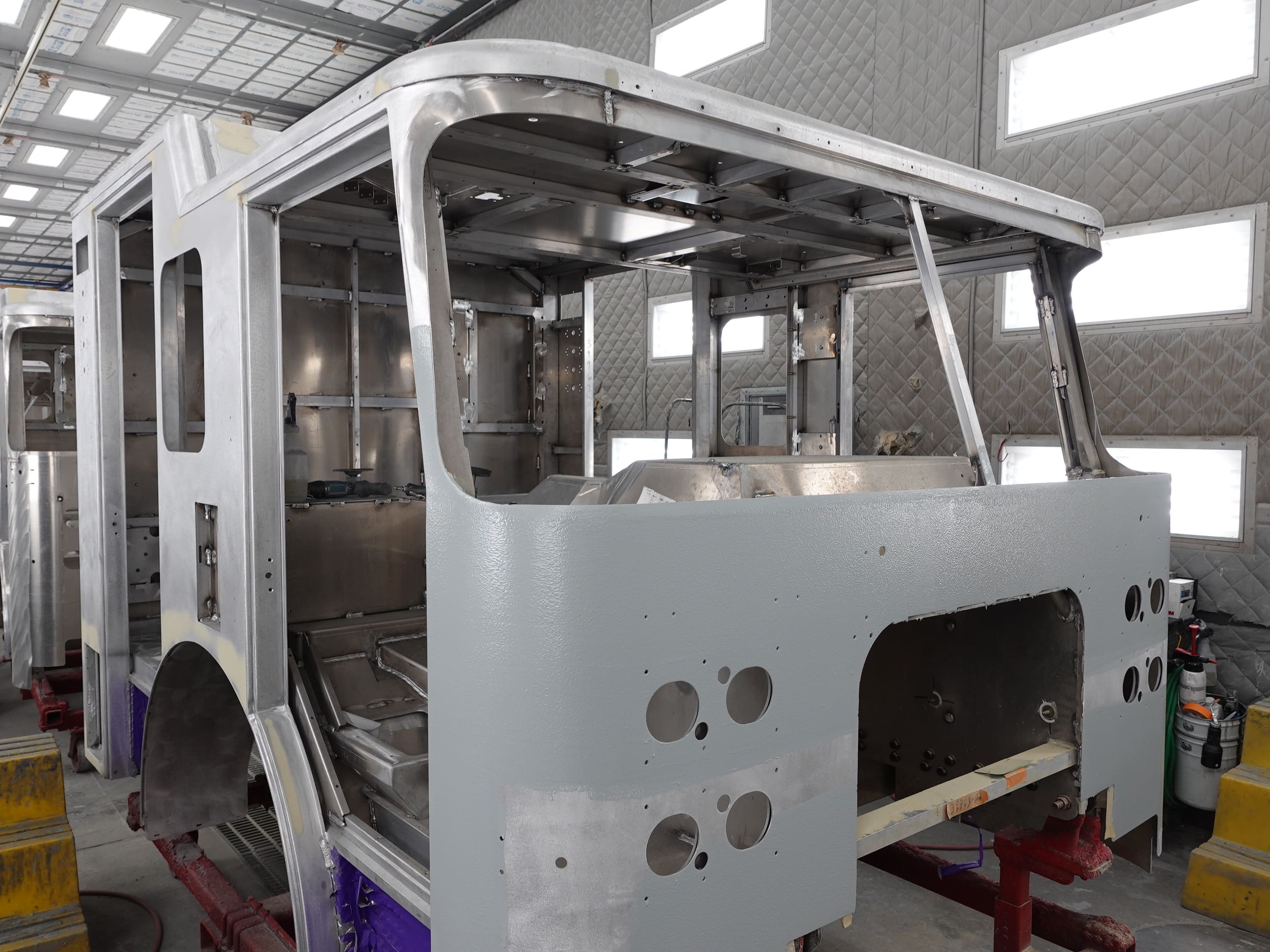

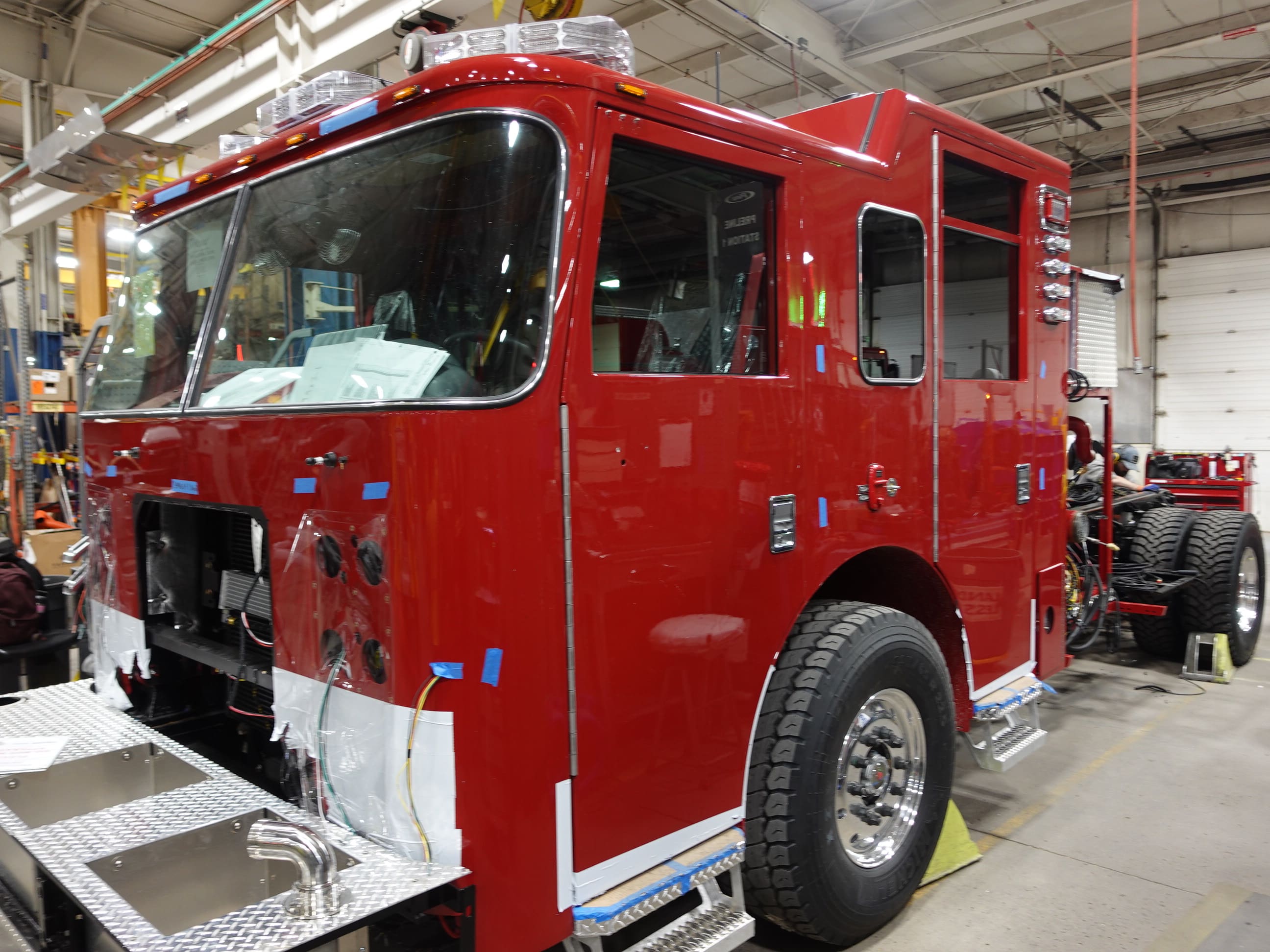

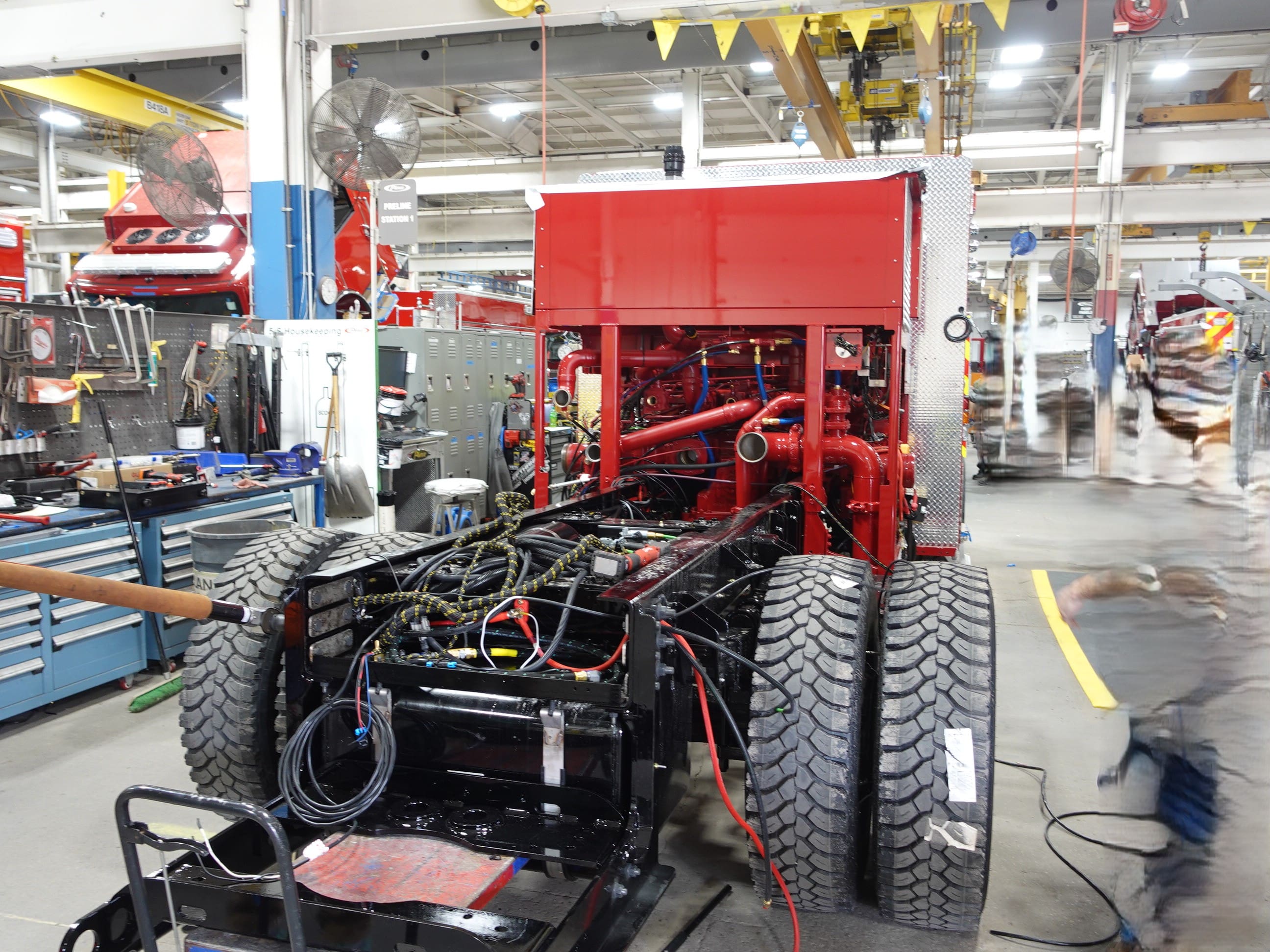

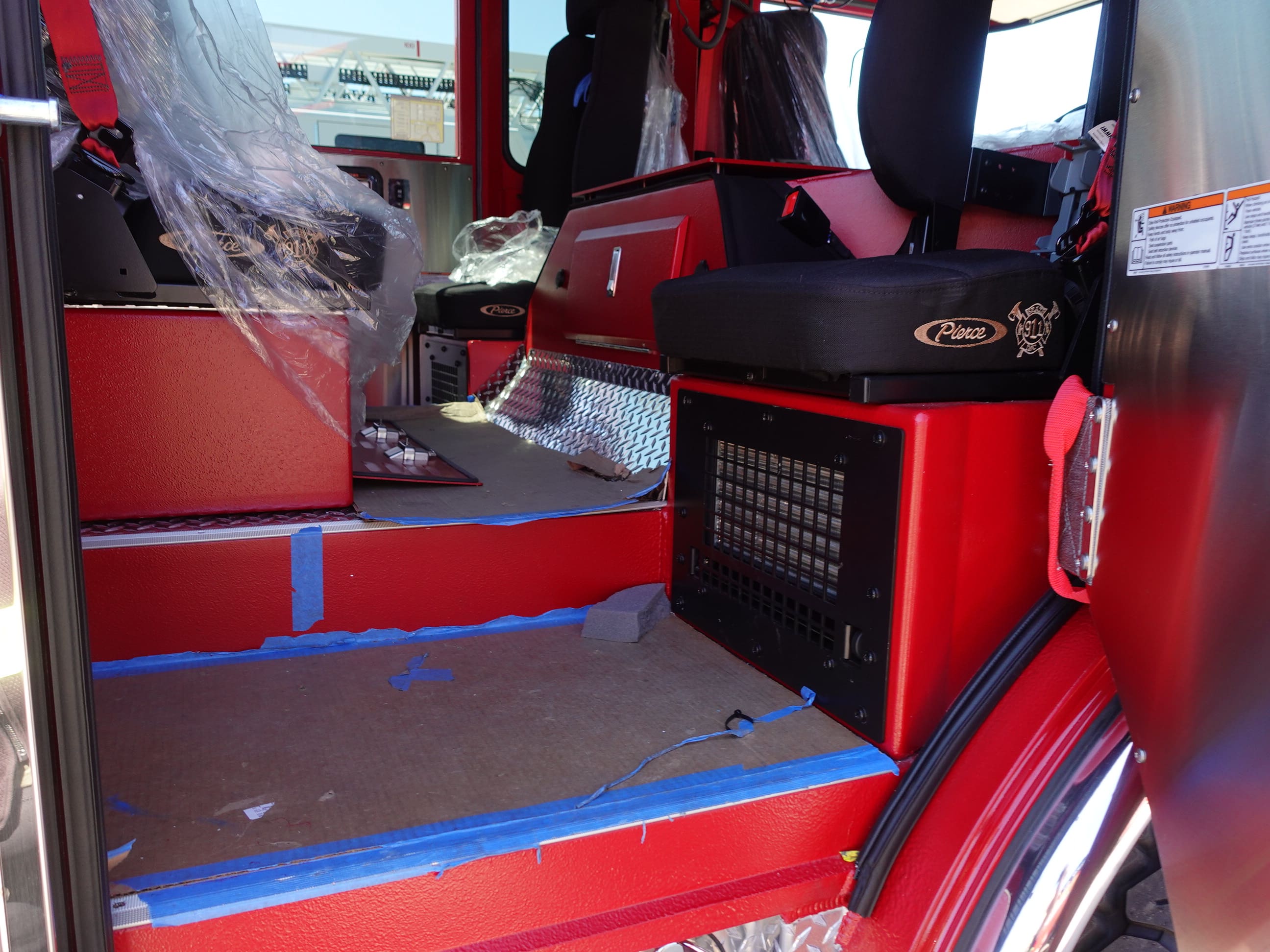

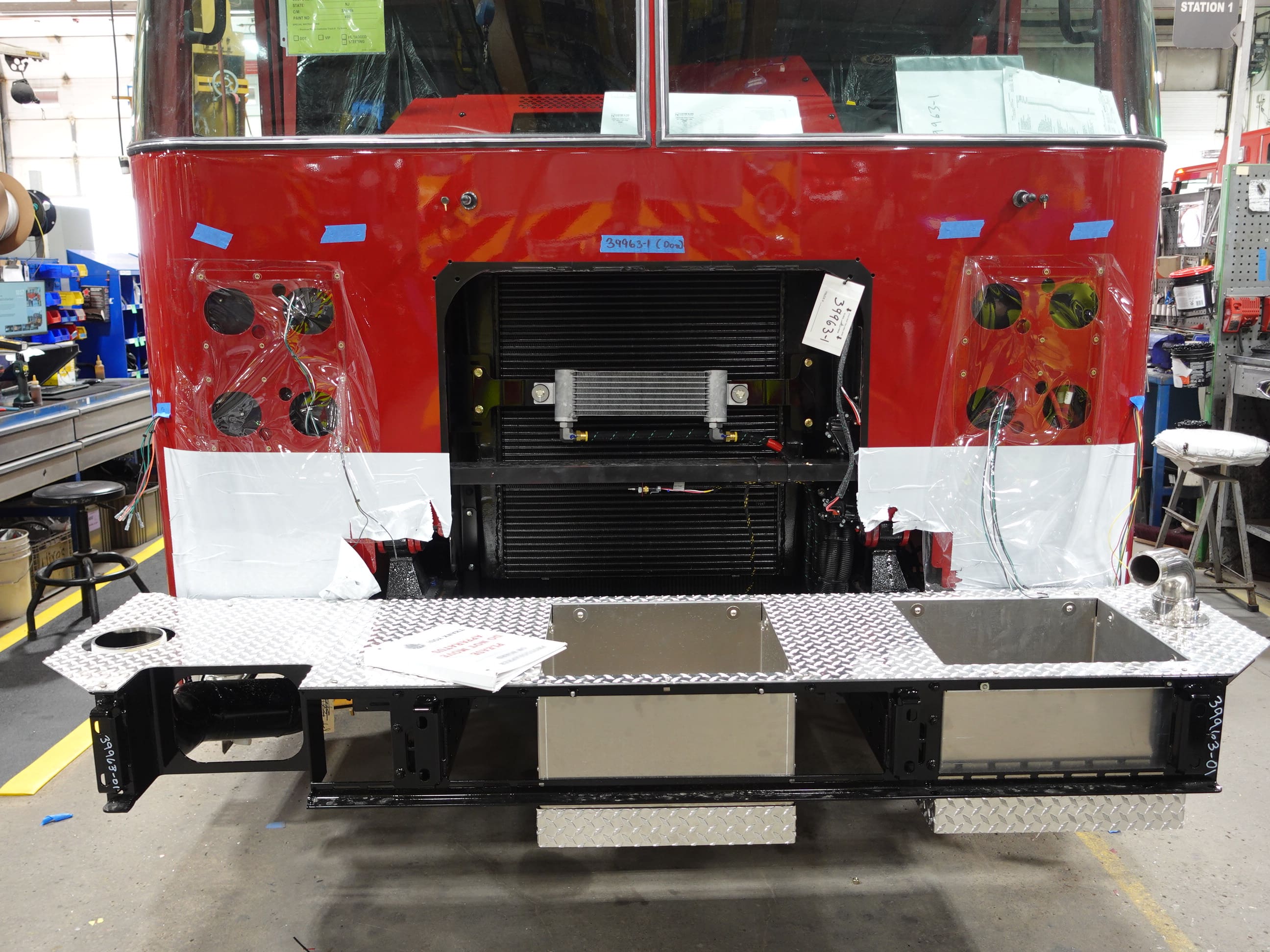

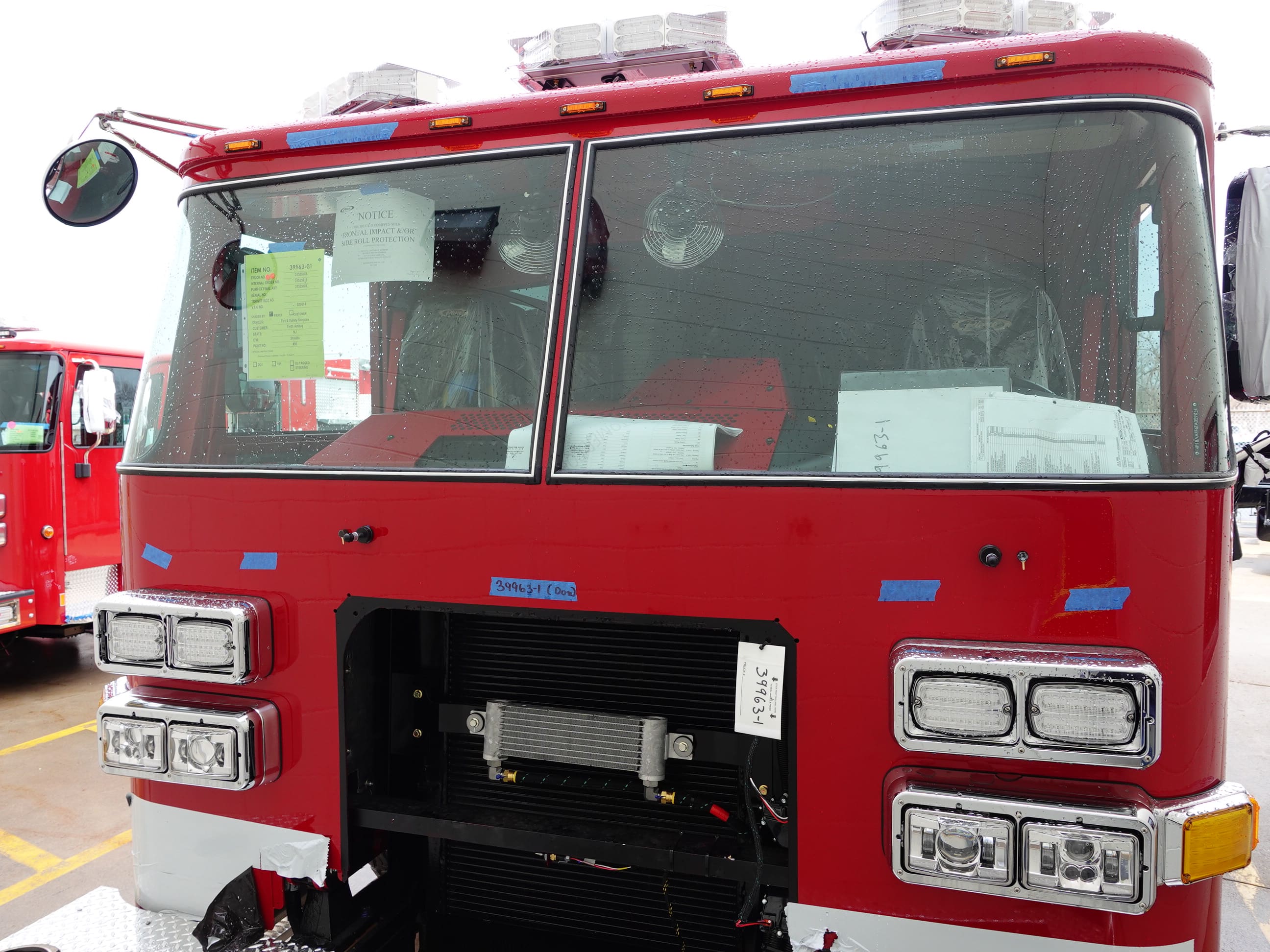

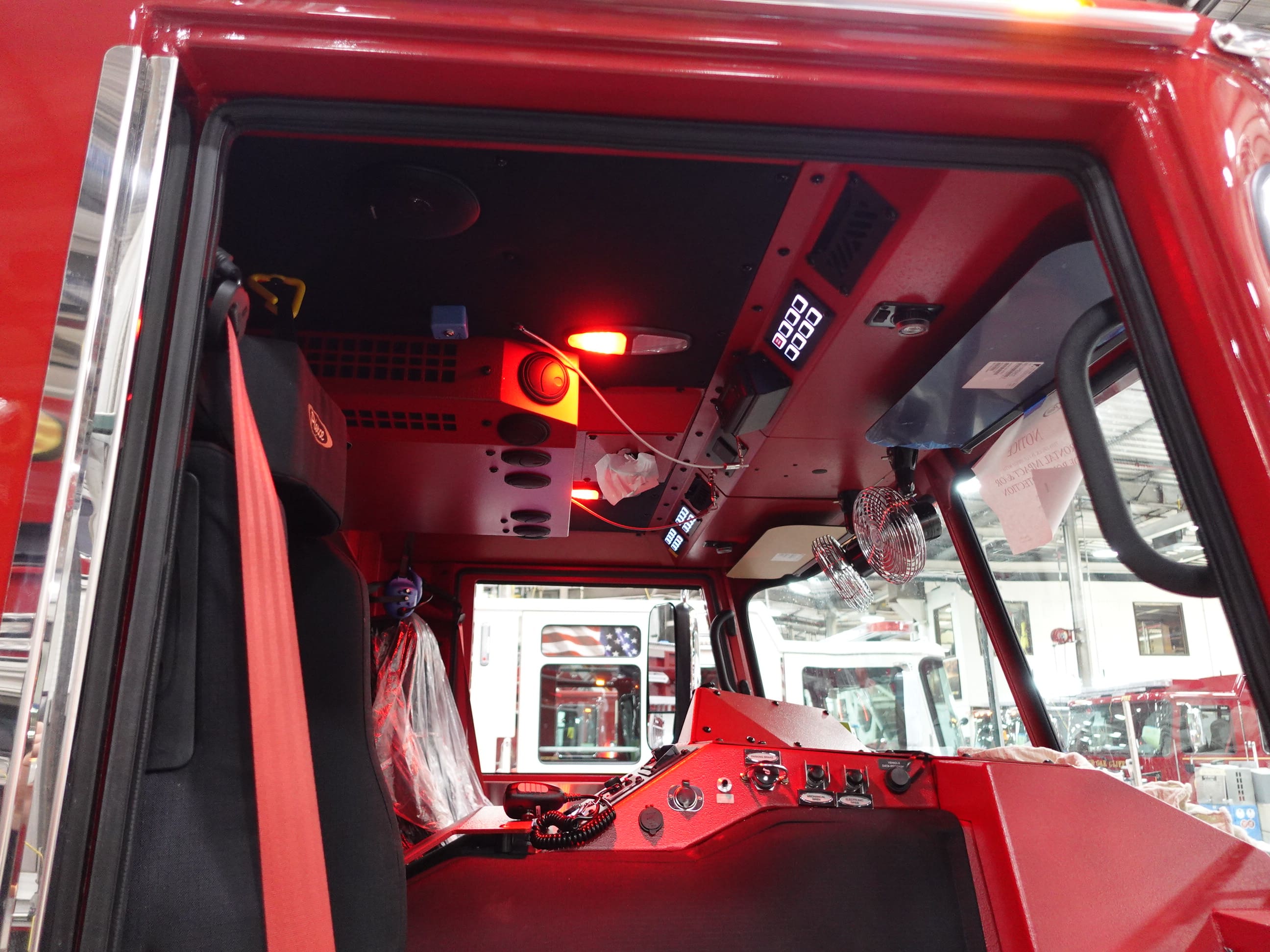

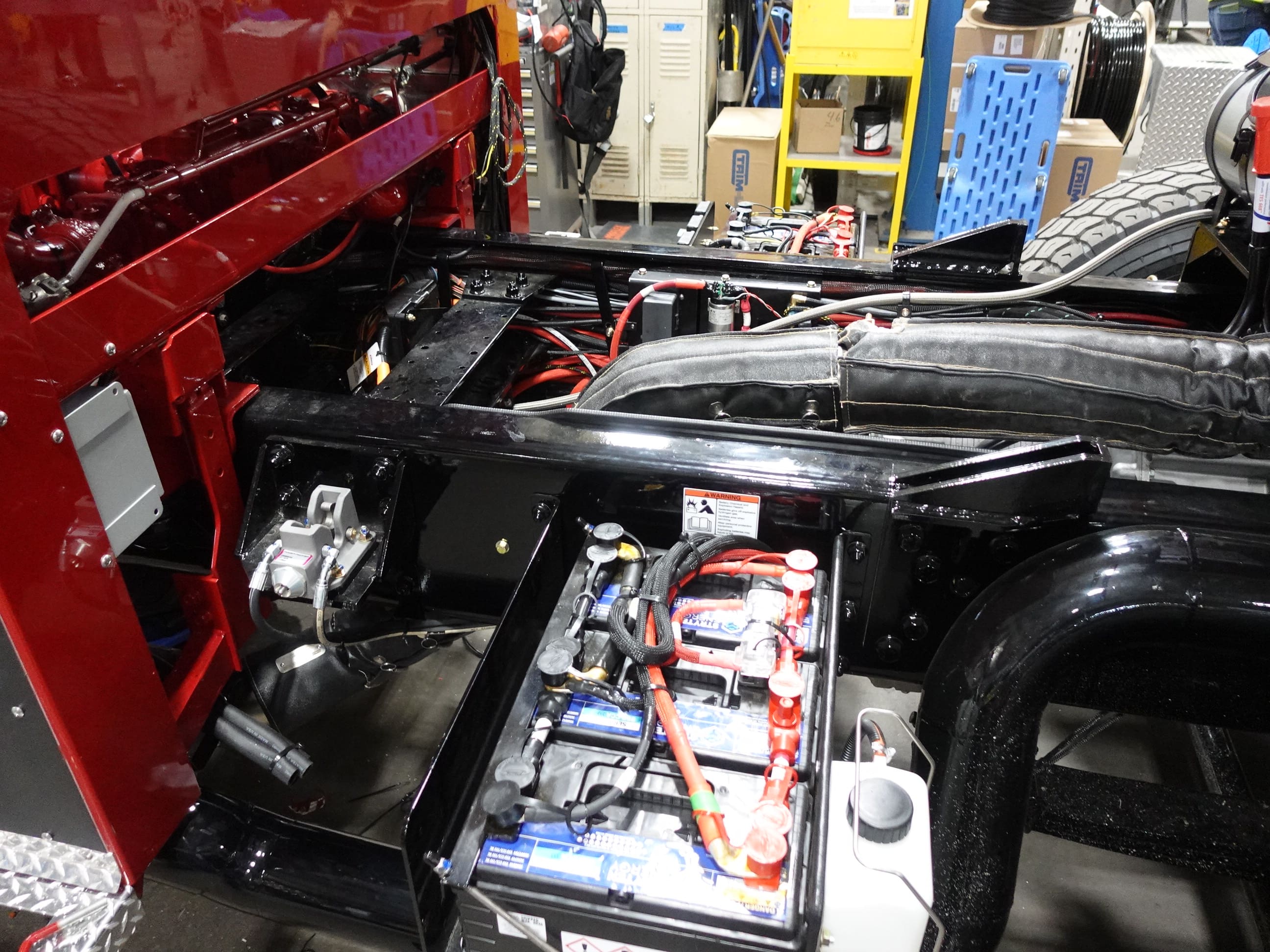

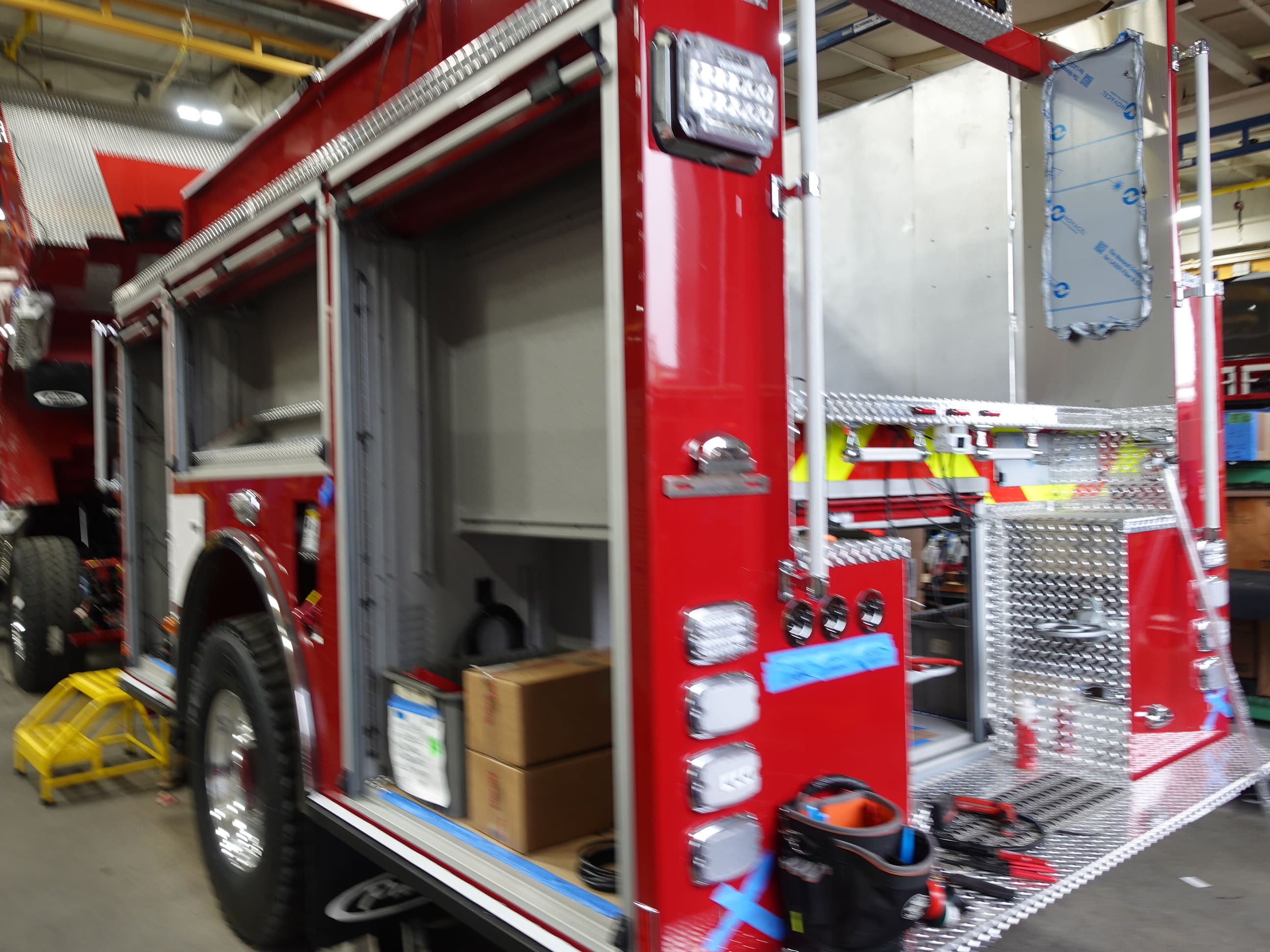

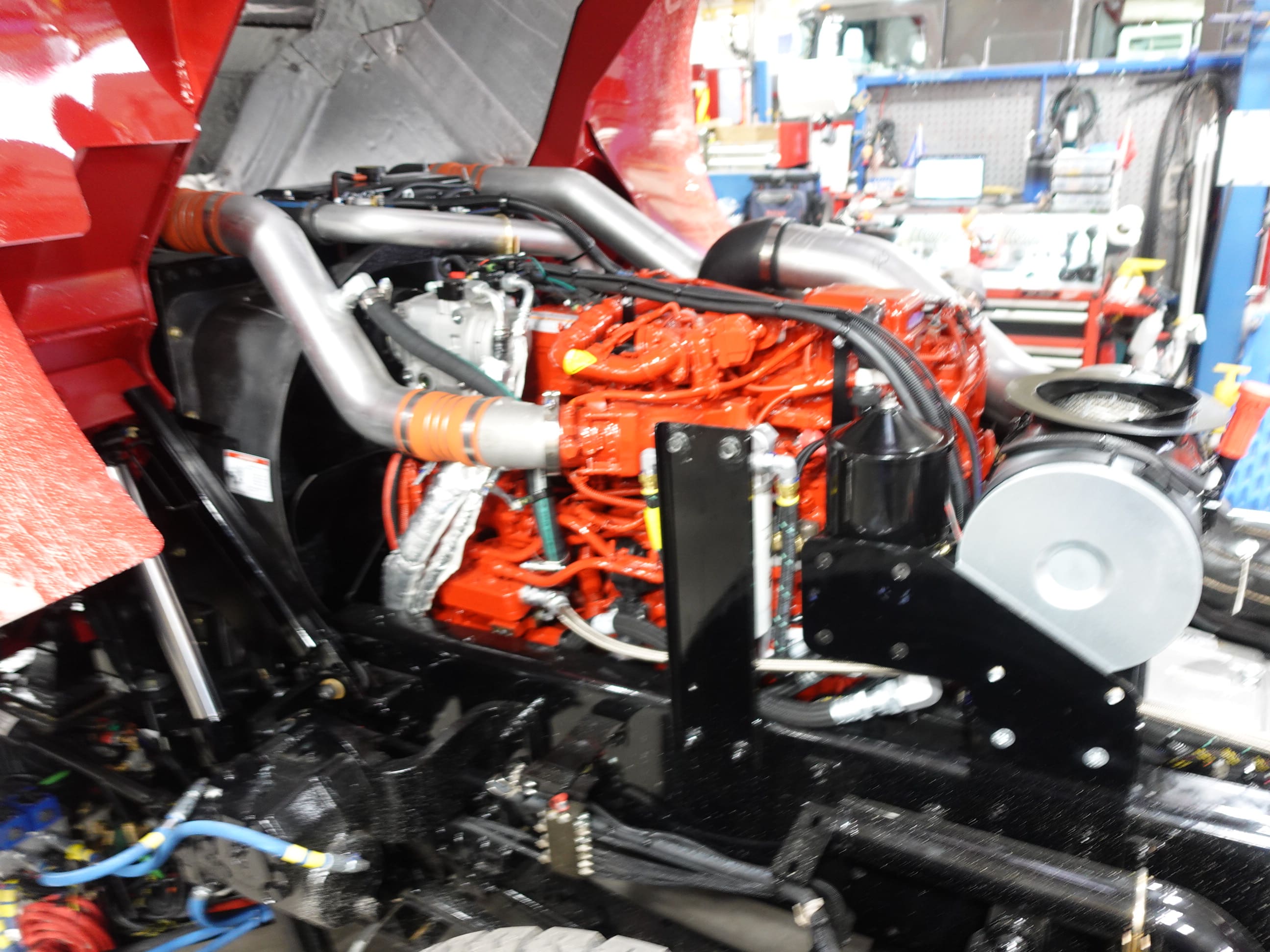

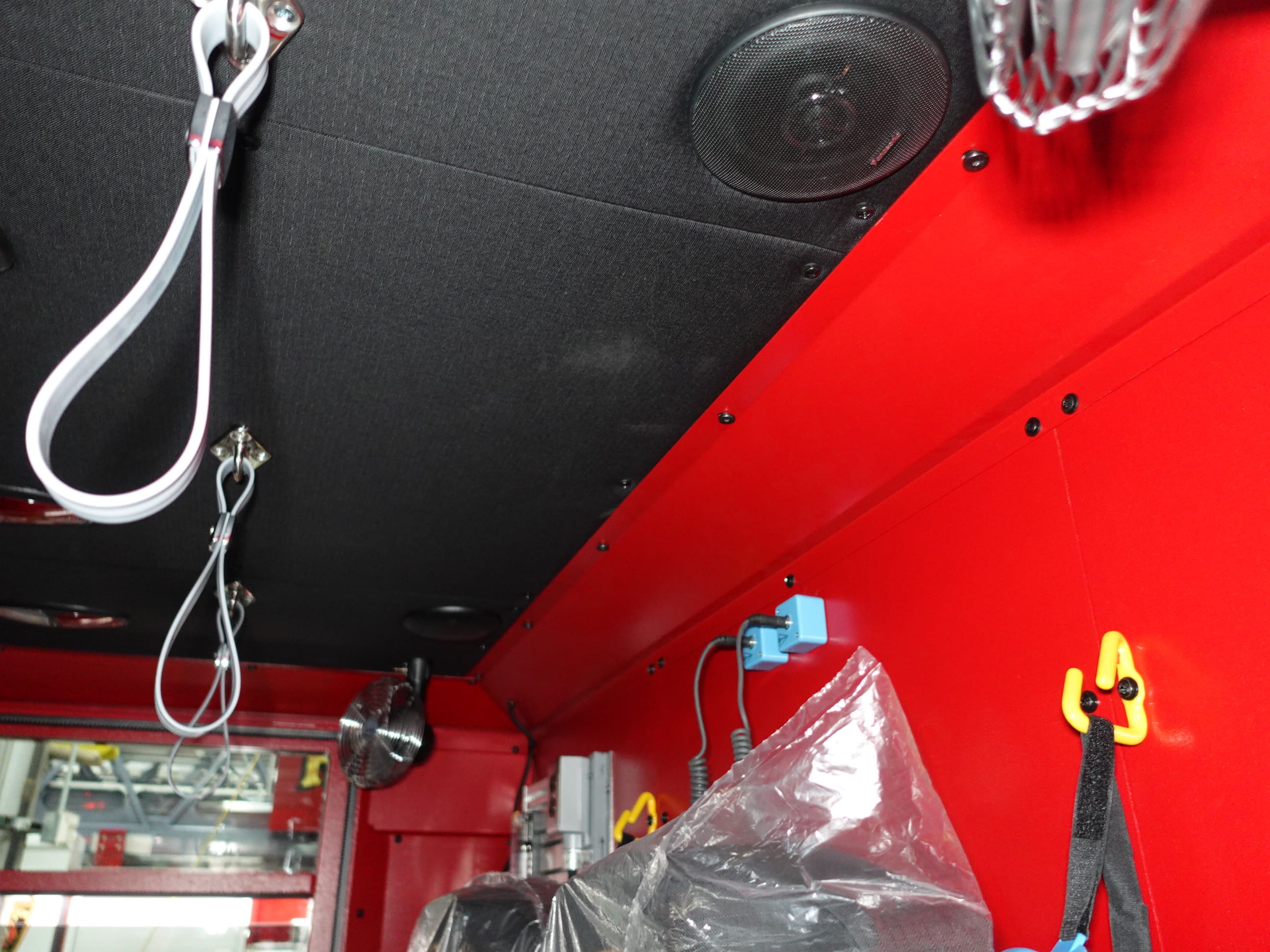

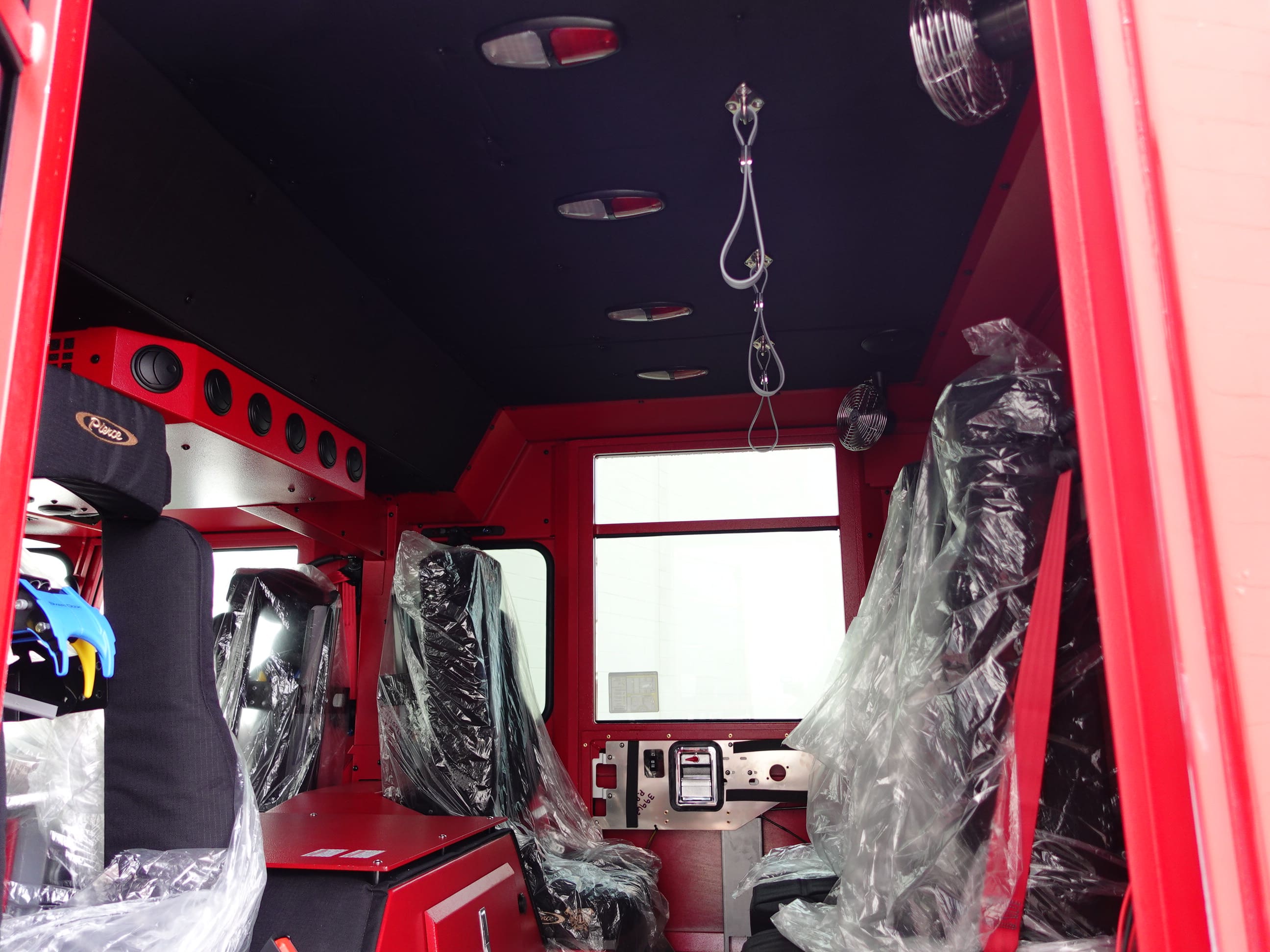

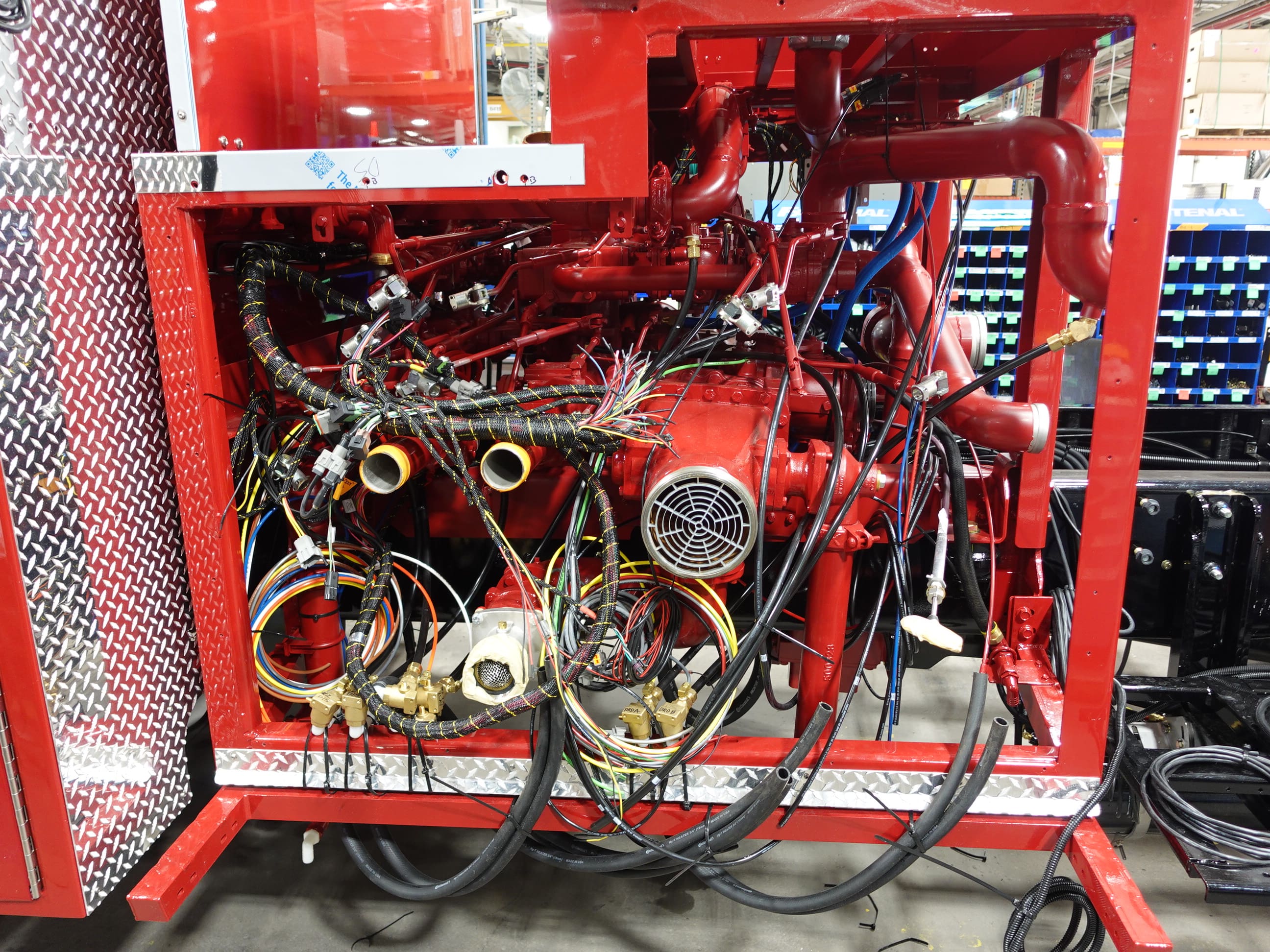

In this report, the cab and pump house were merged with the frame followed by body installation.

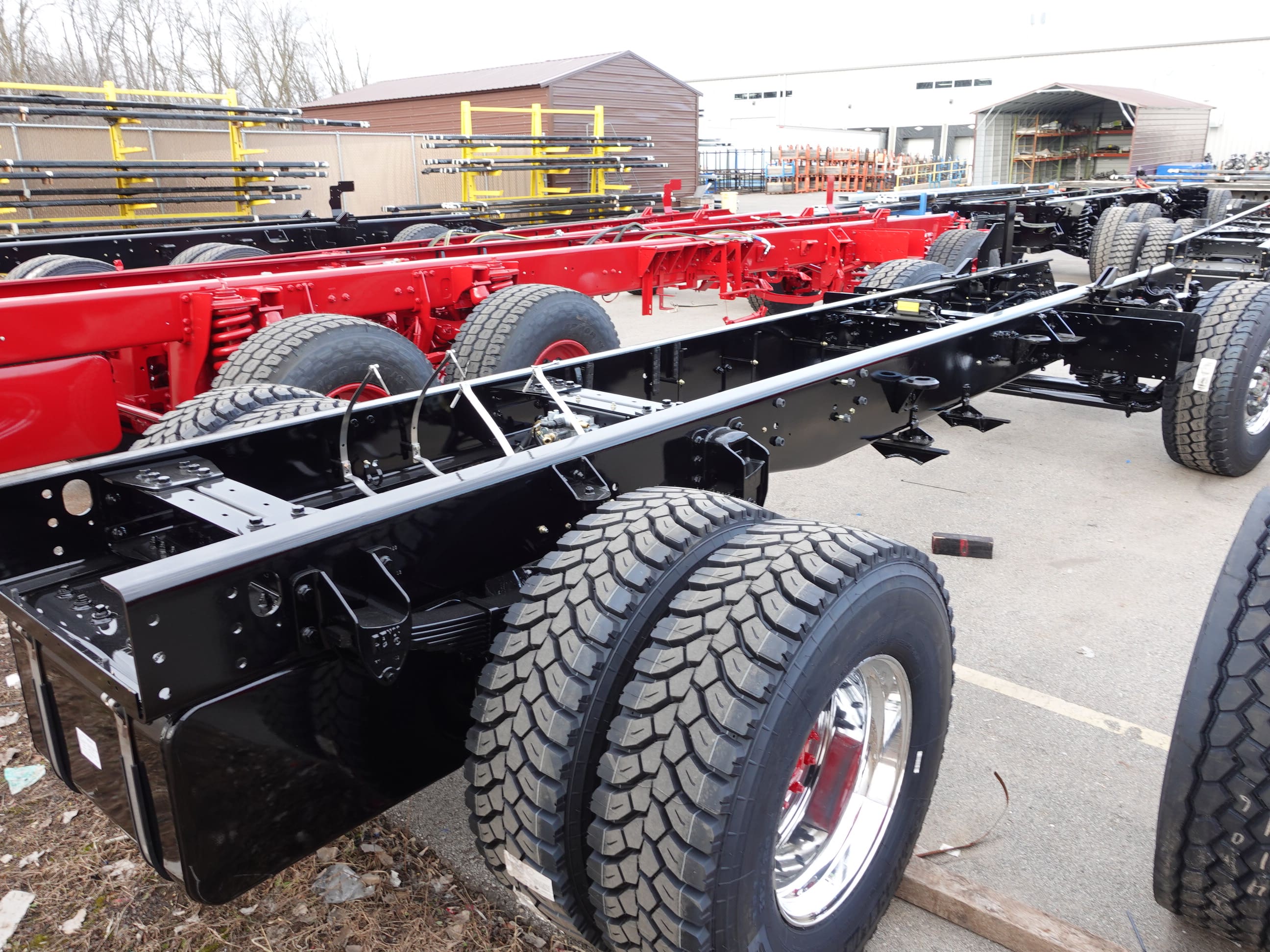

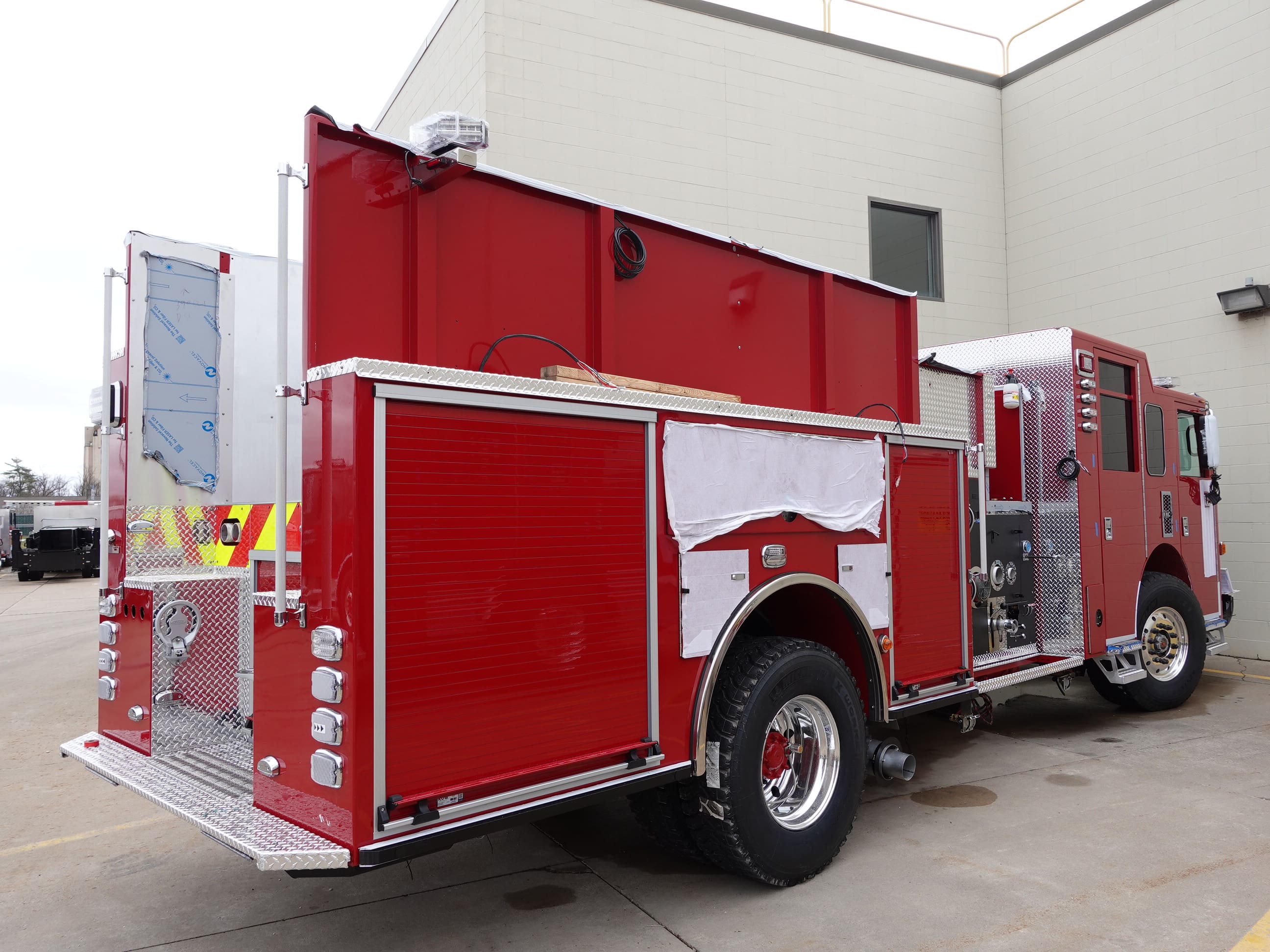

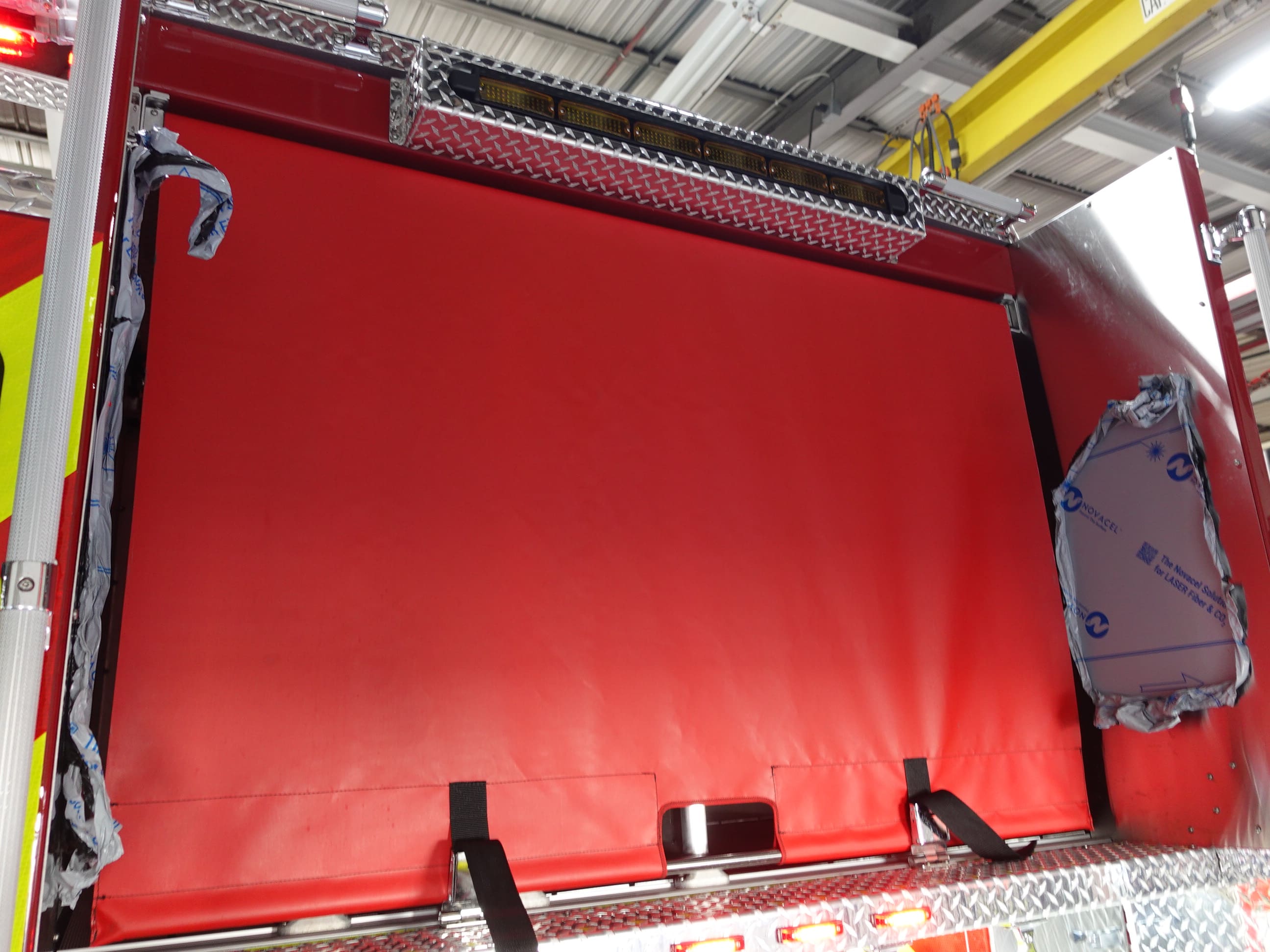

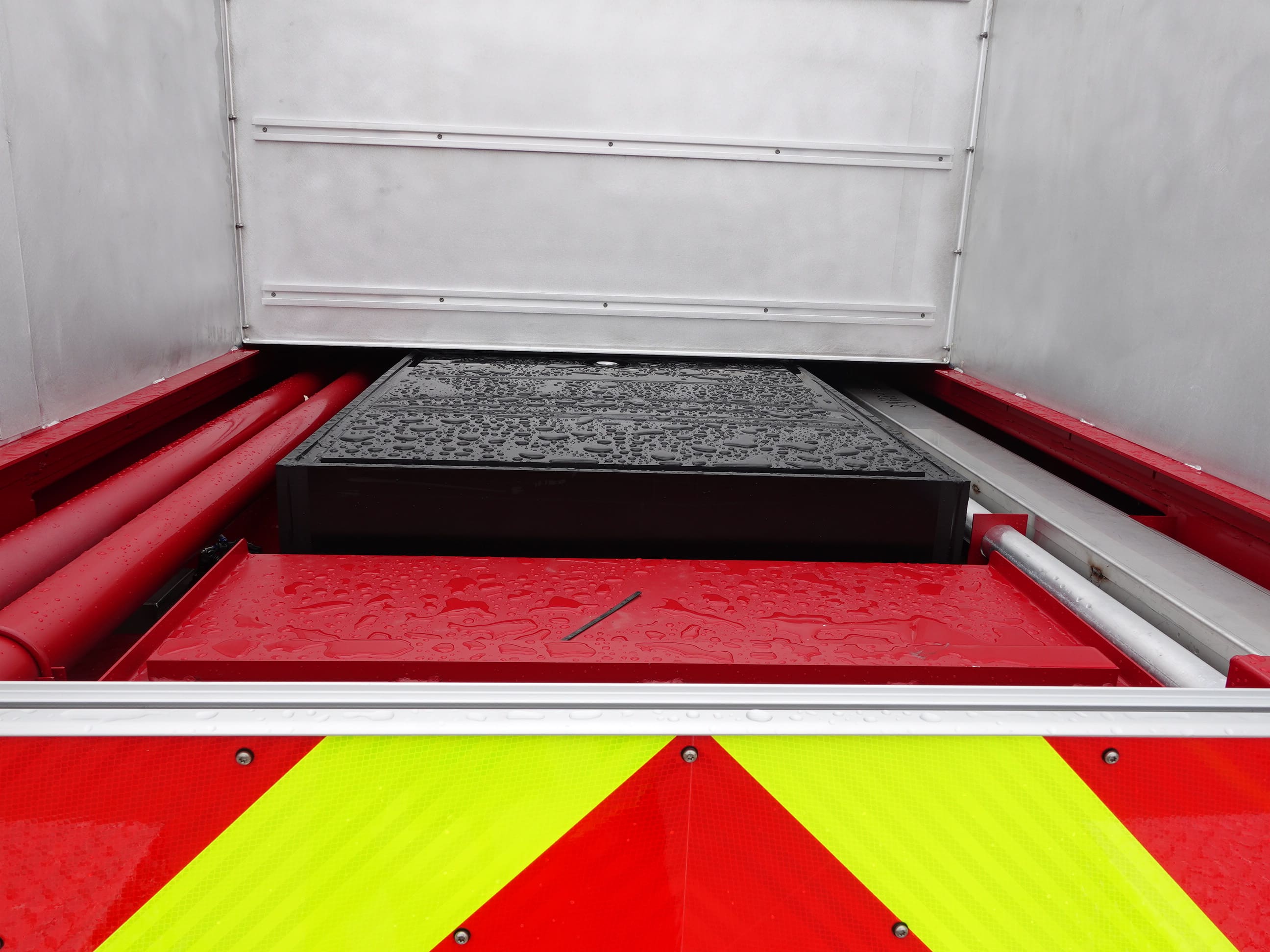

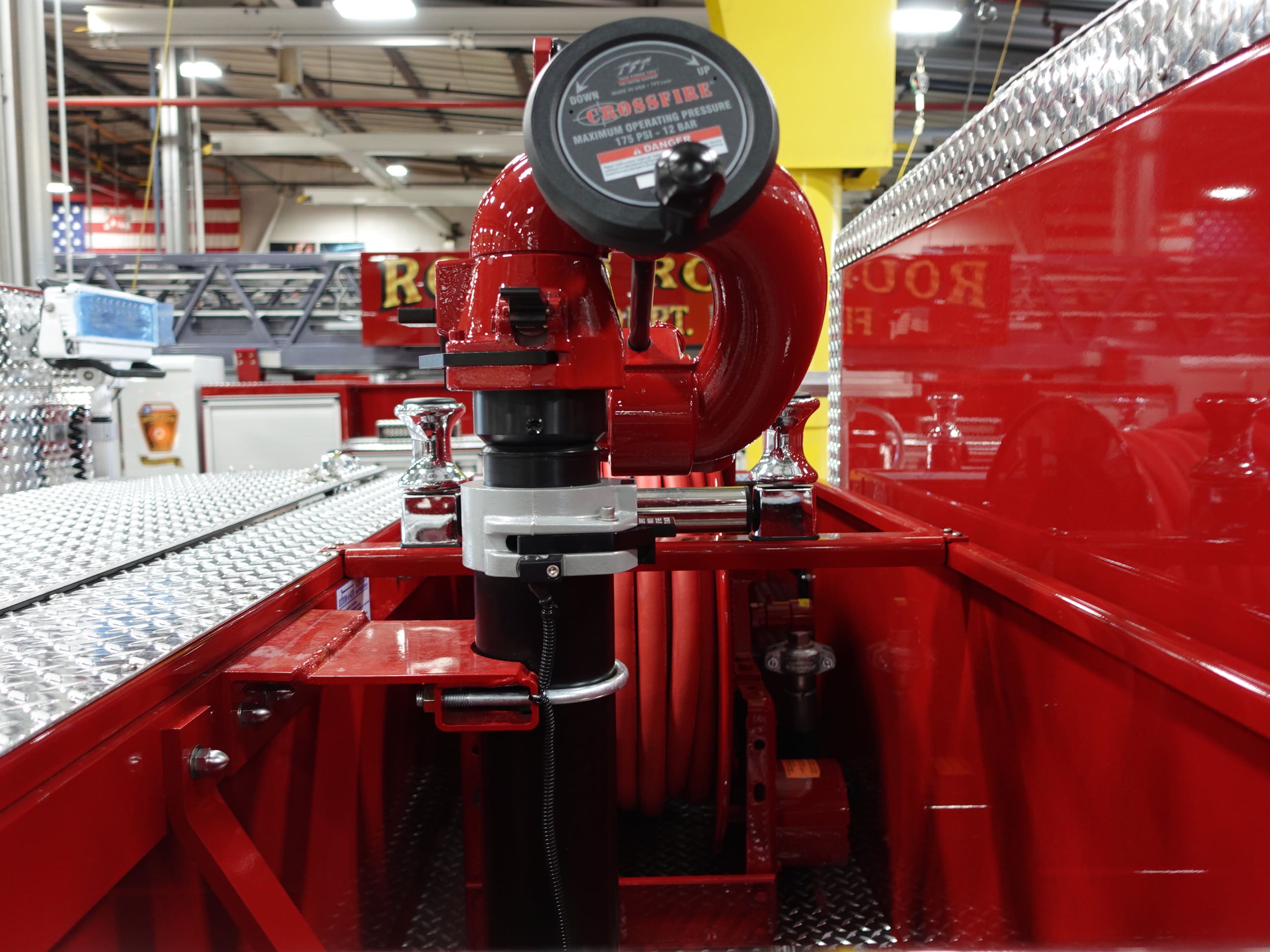

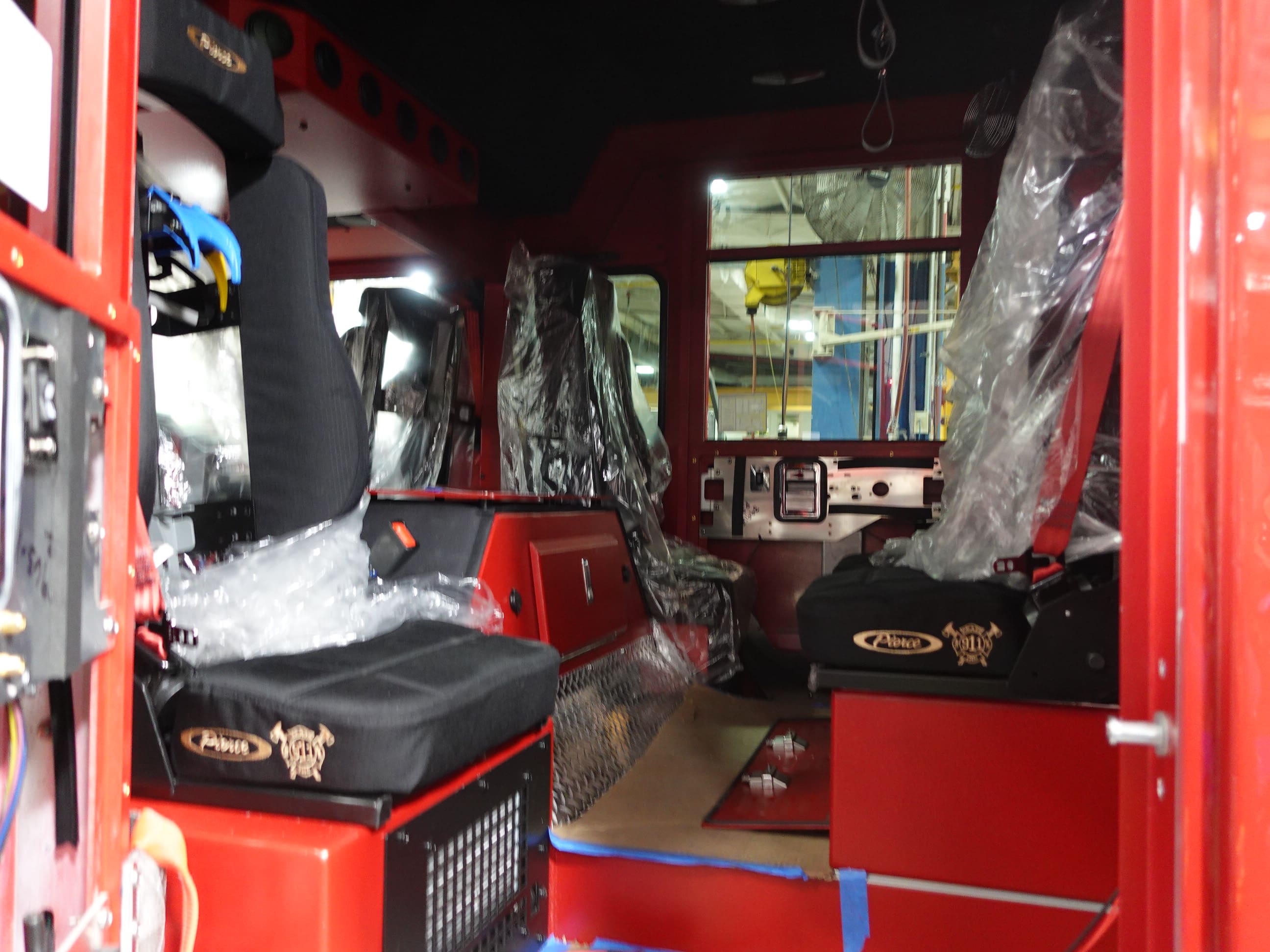

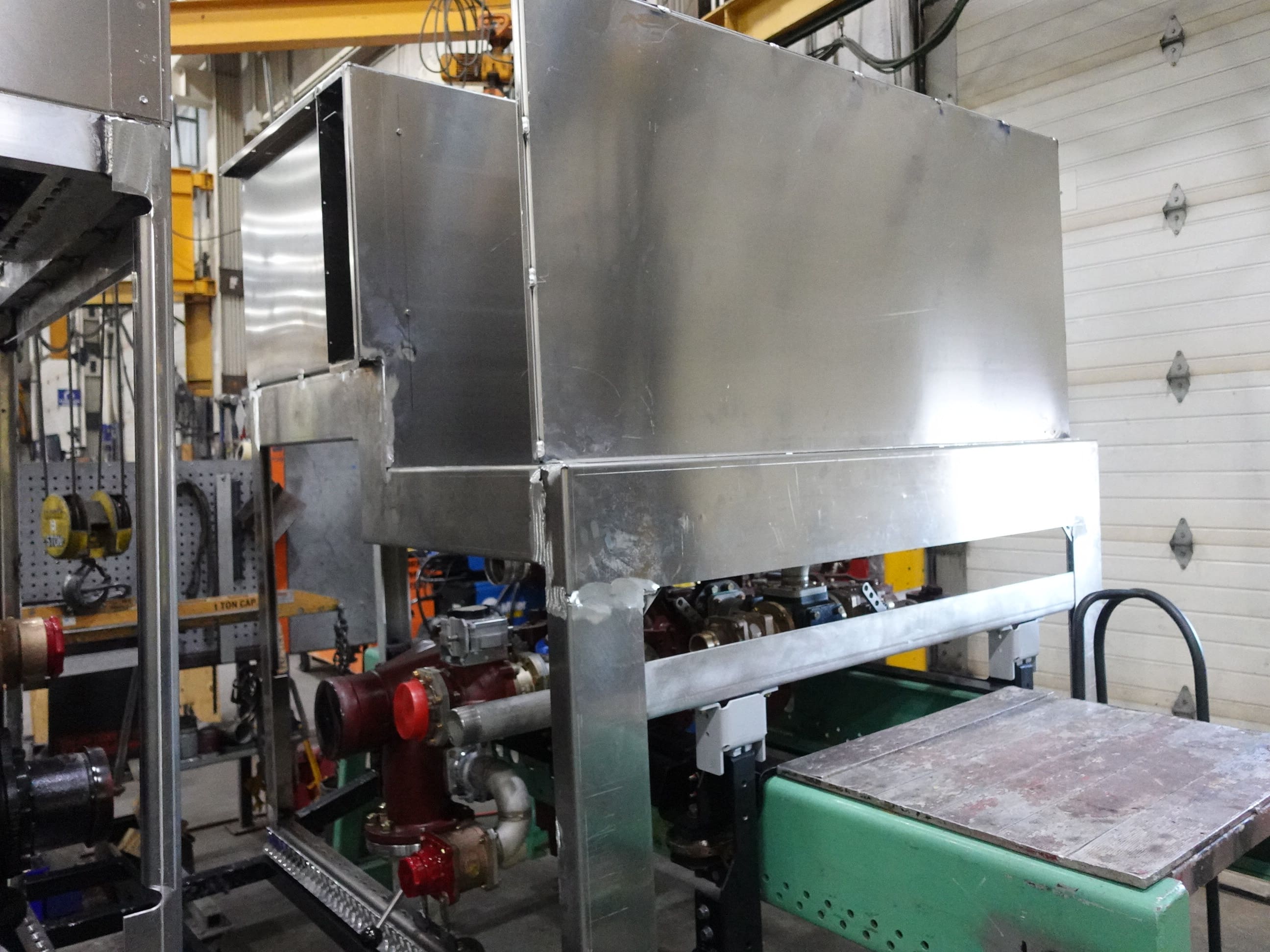

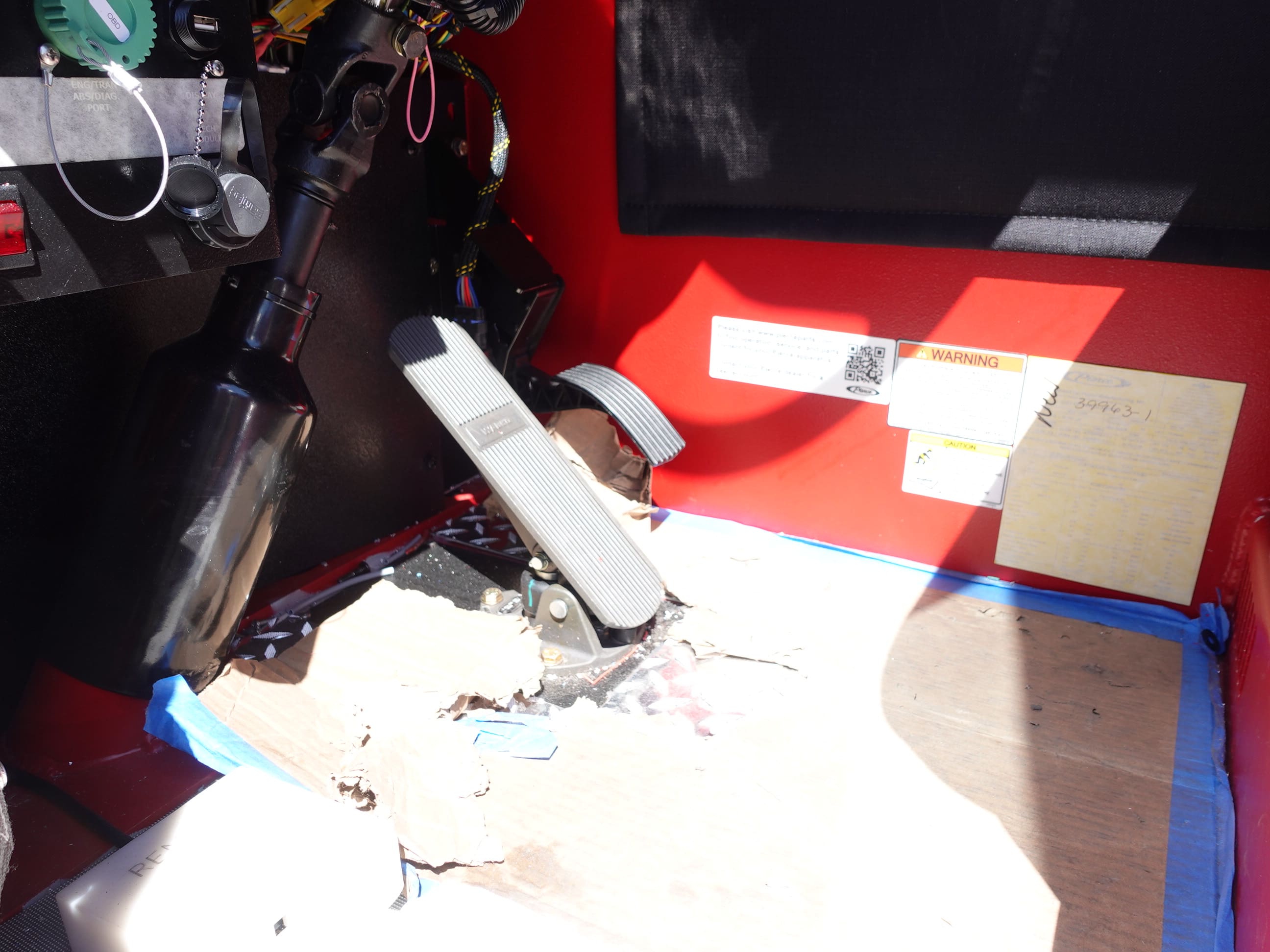

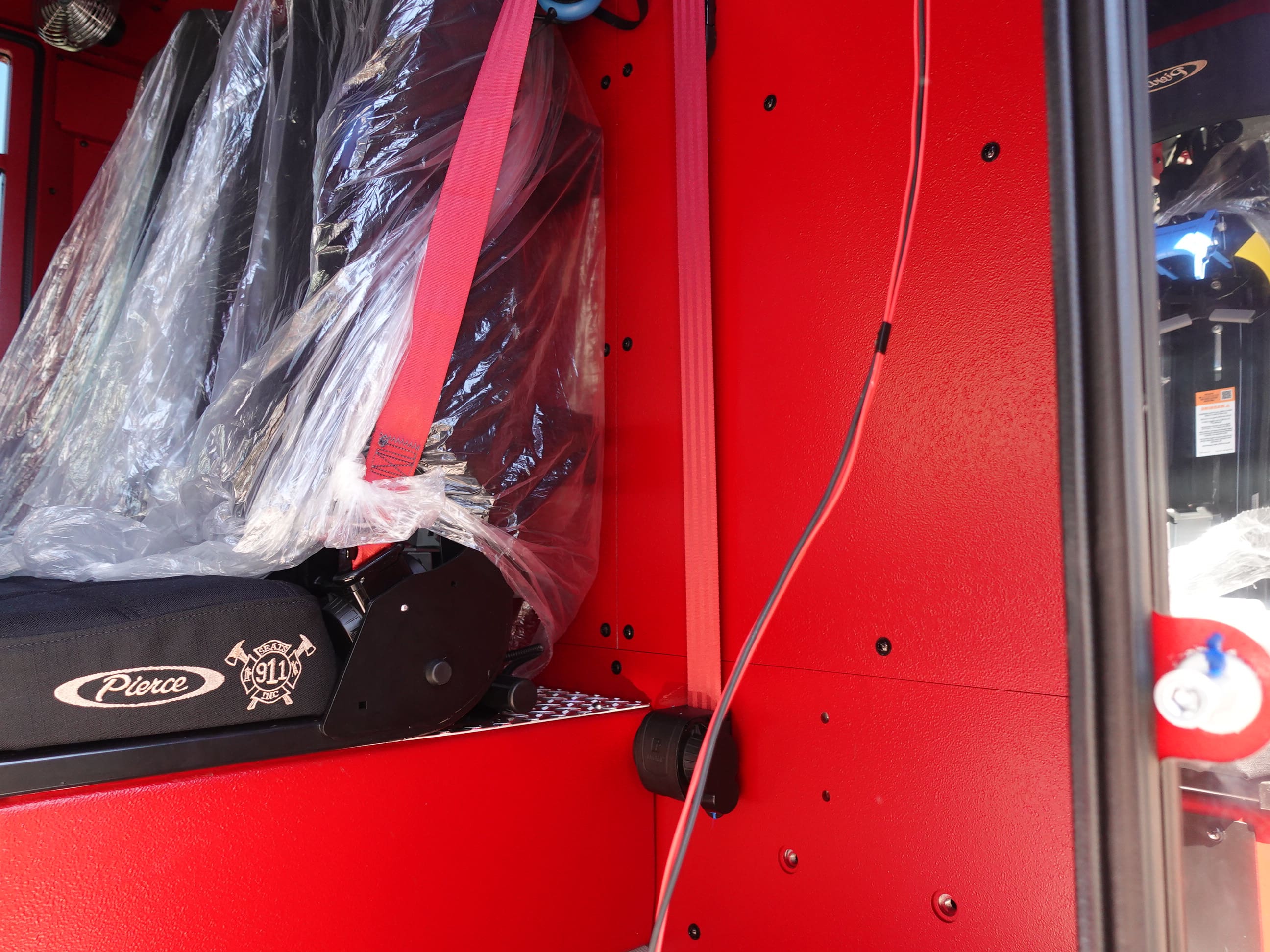

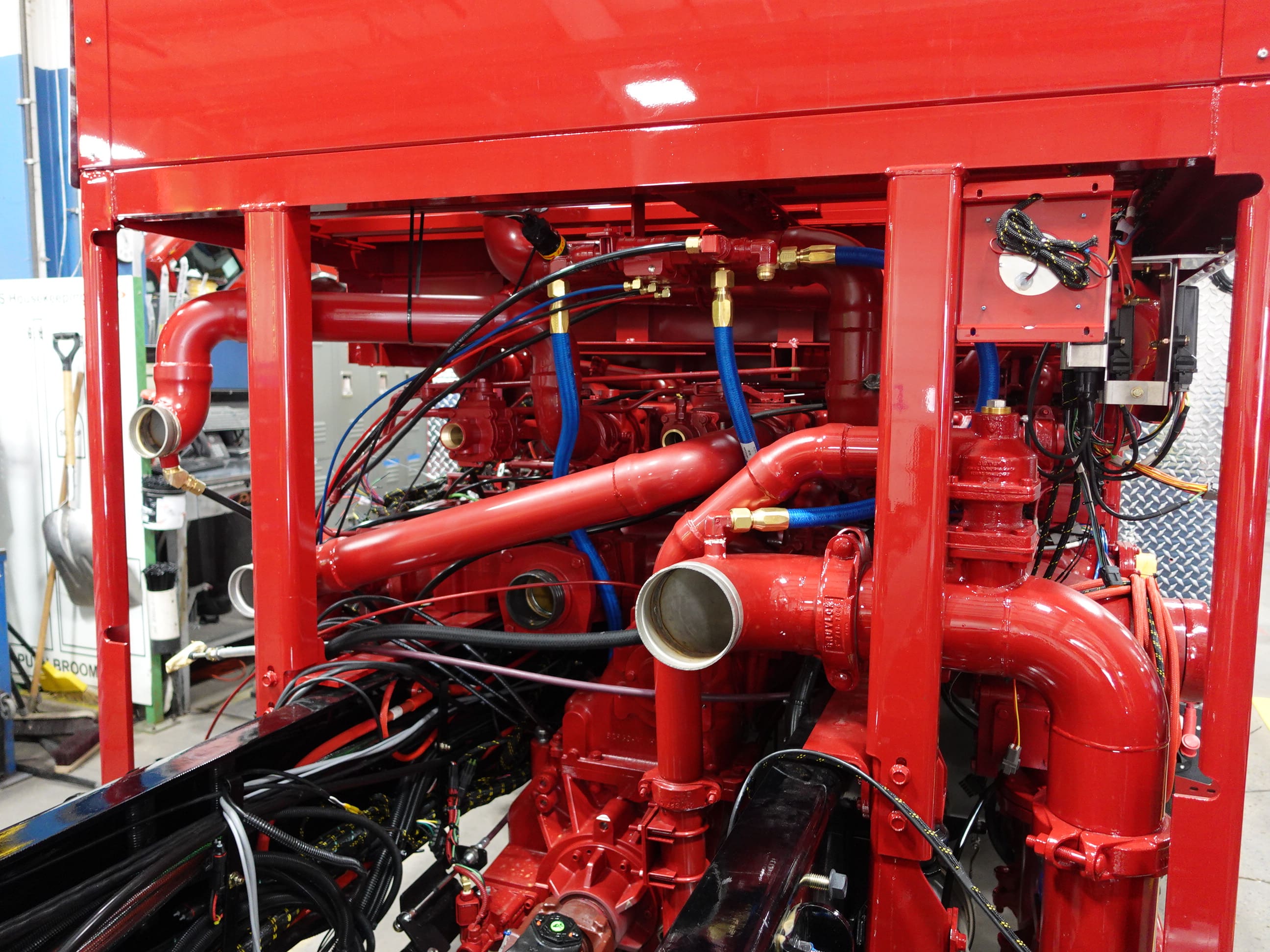

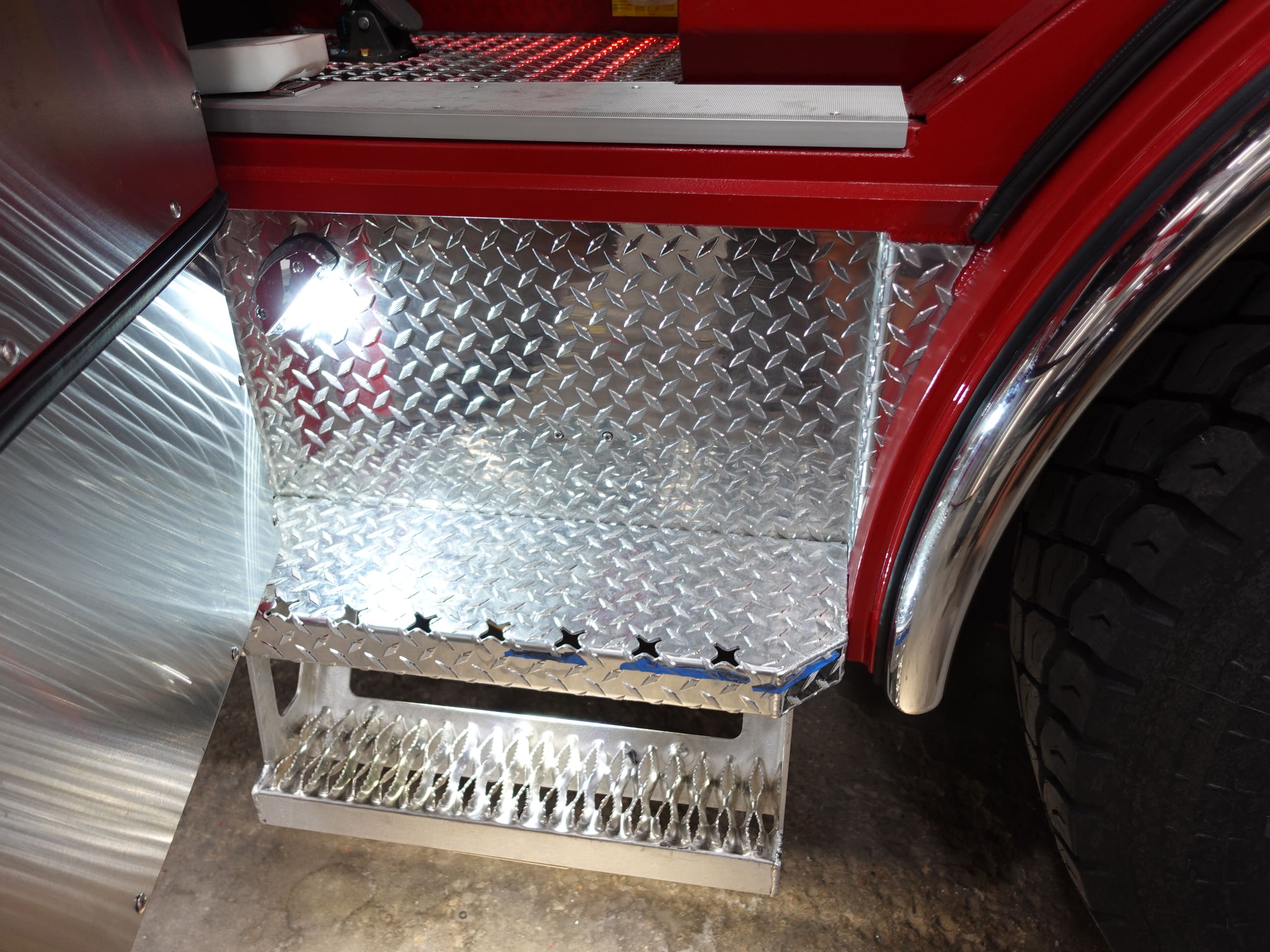

03-20-26

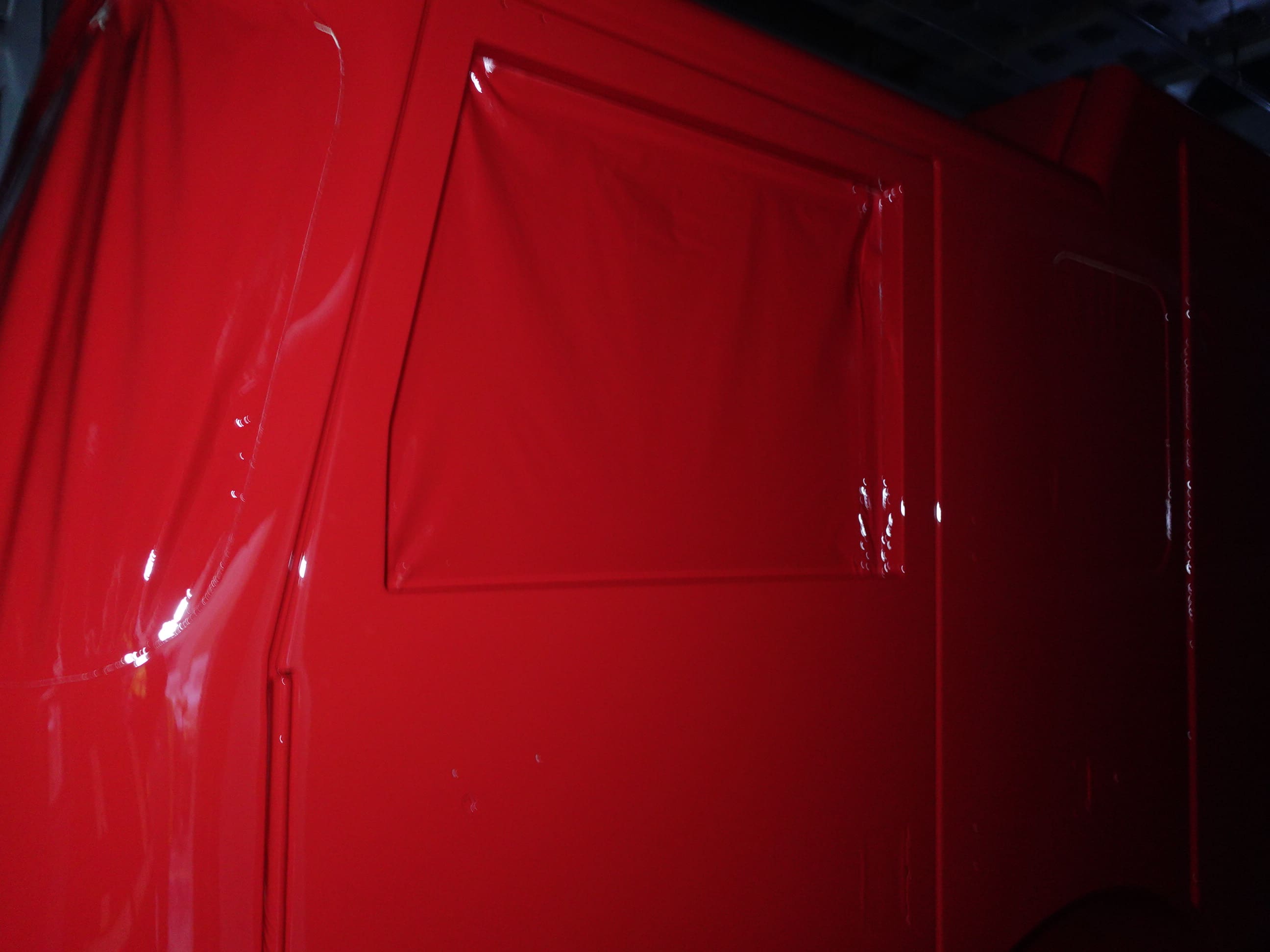

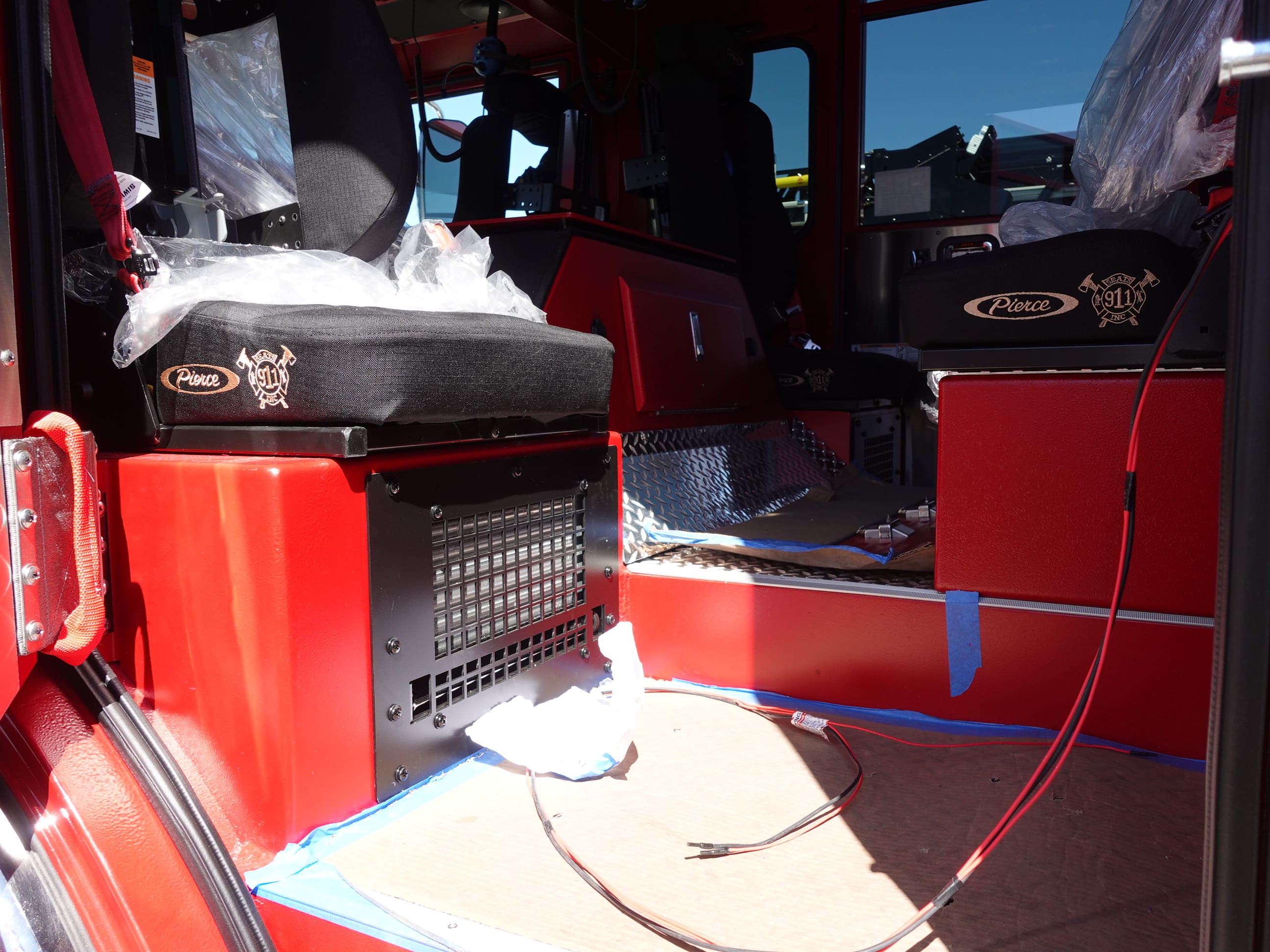

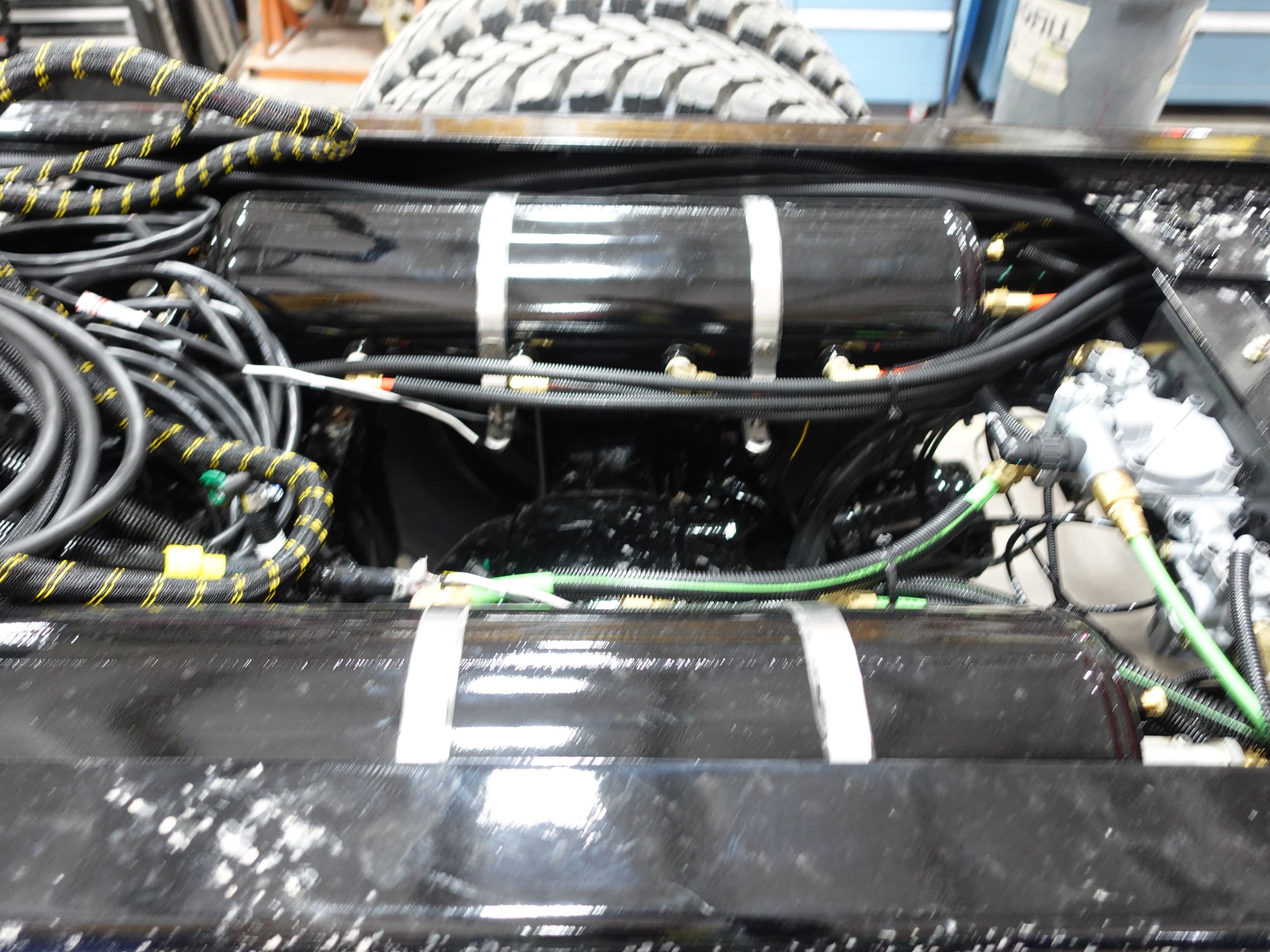

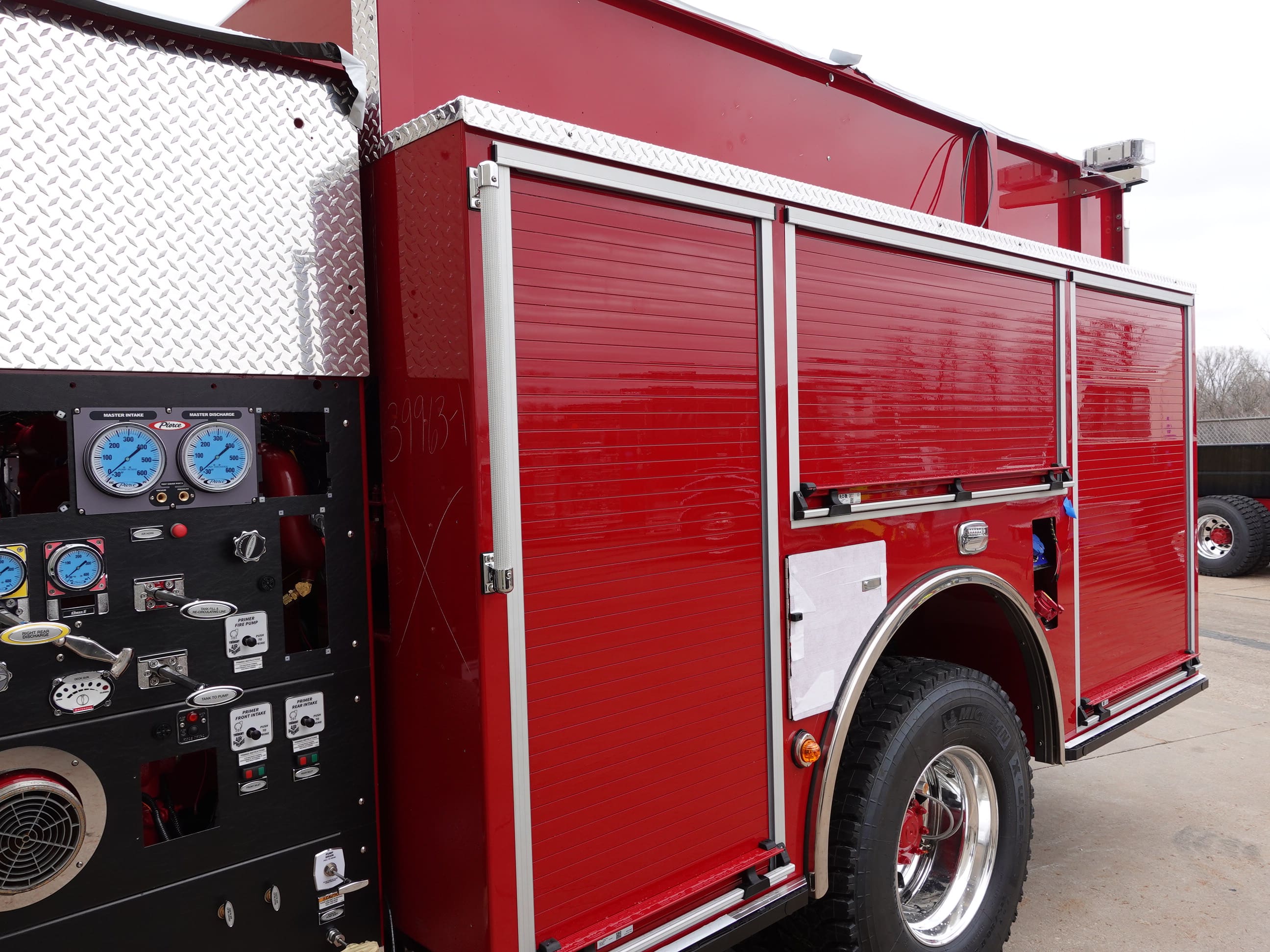

In this report, the cab was staged, the frame build continued, the pump house continued initial assembly, and the body began the paint process.
03-13-26

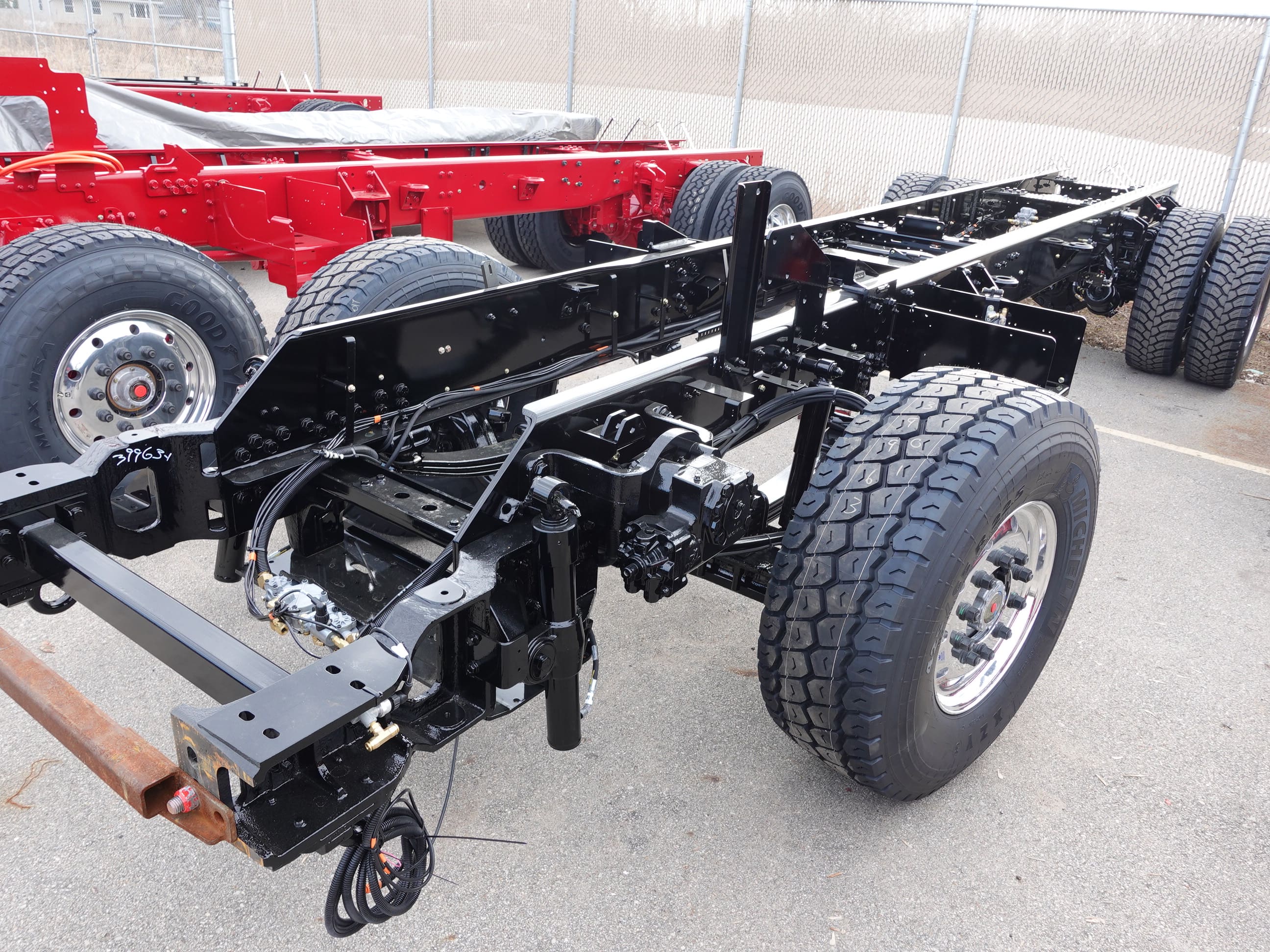

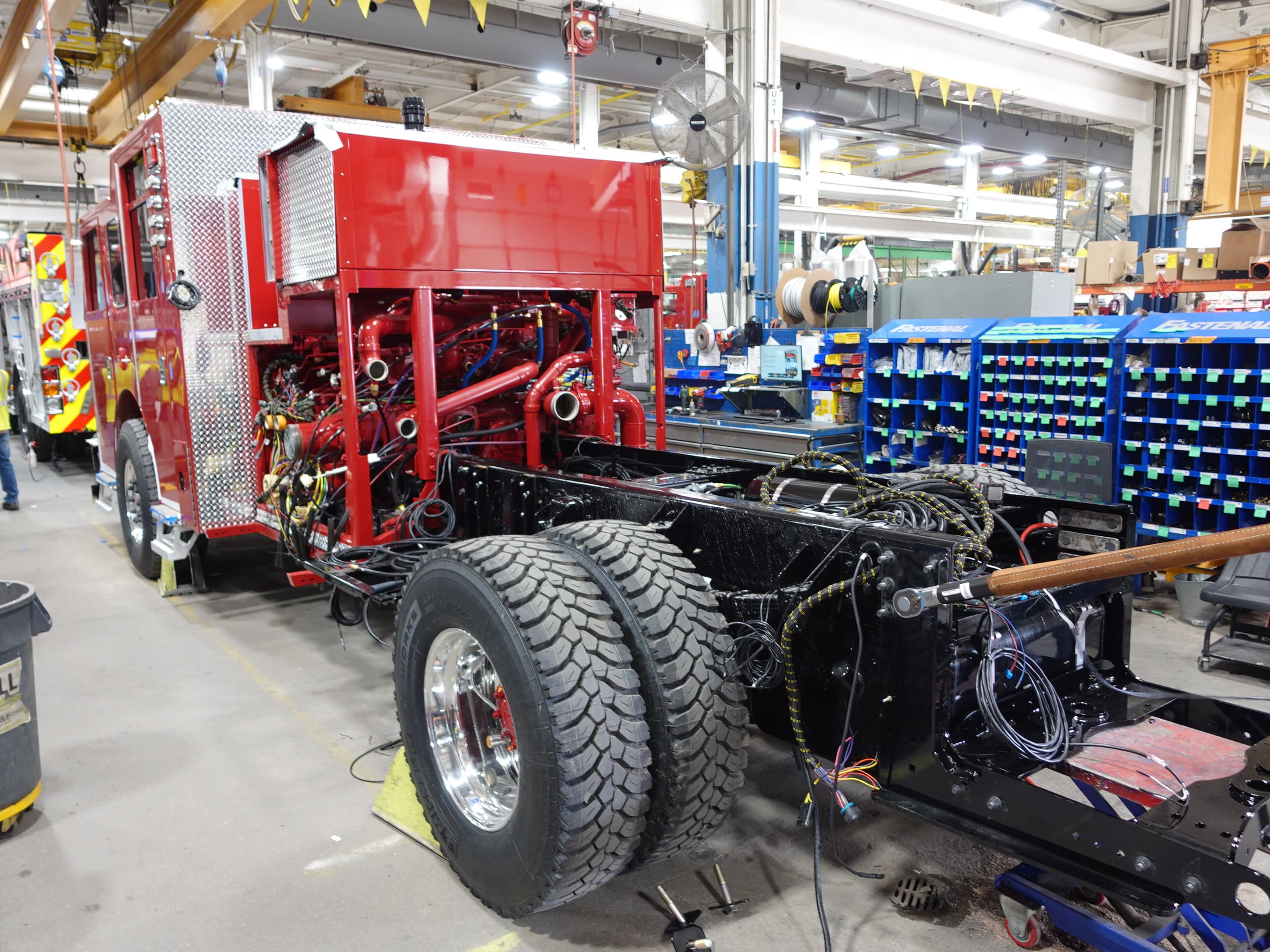

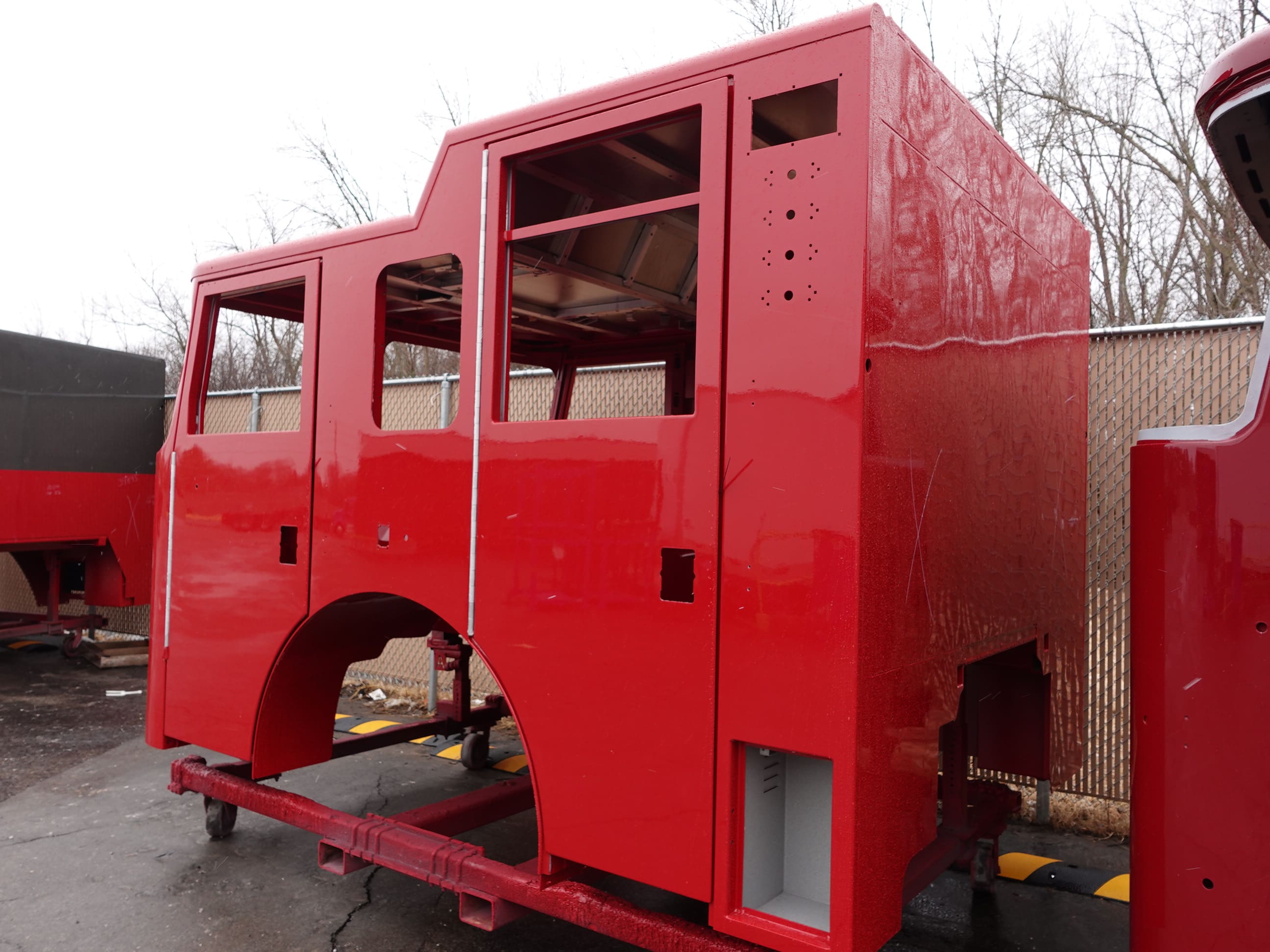

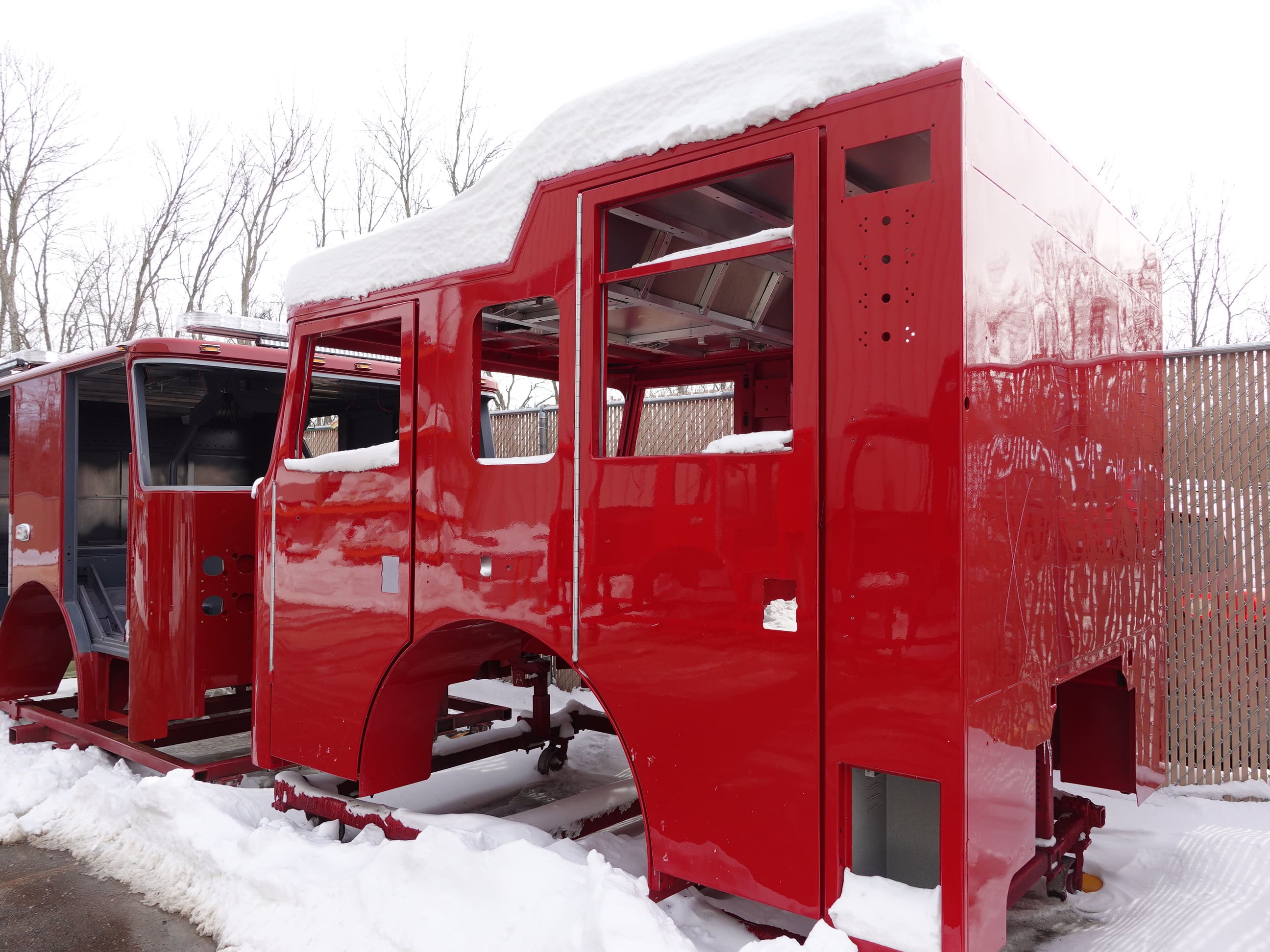

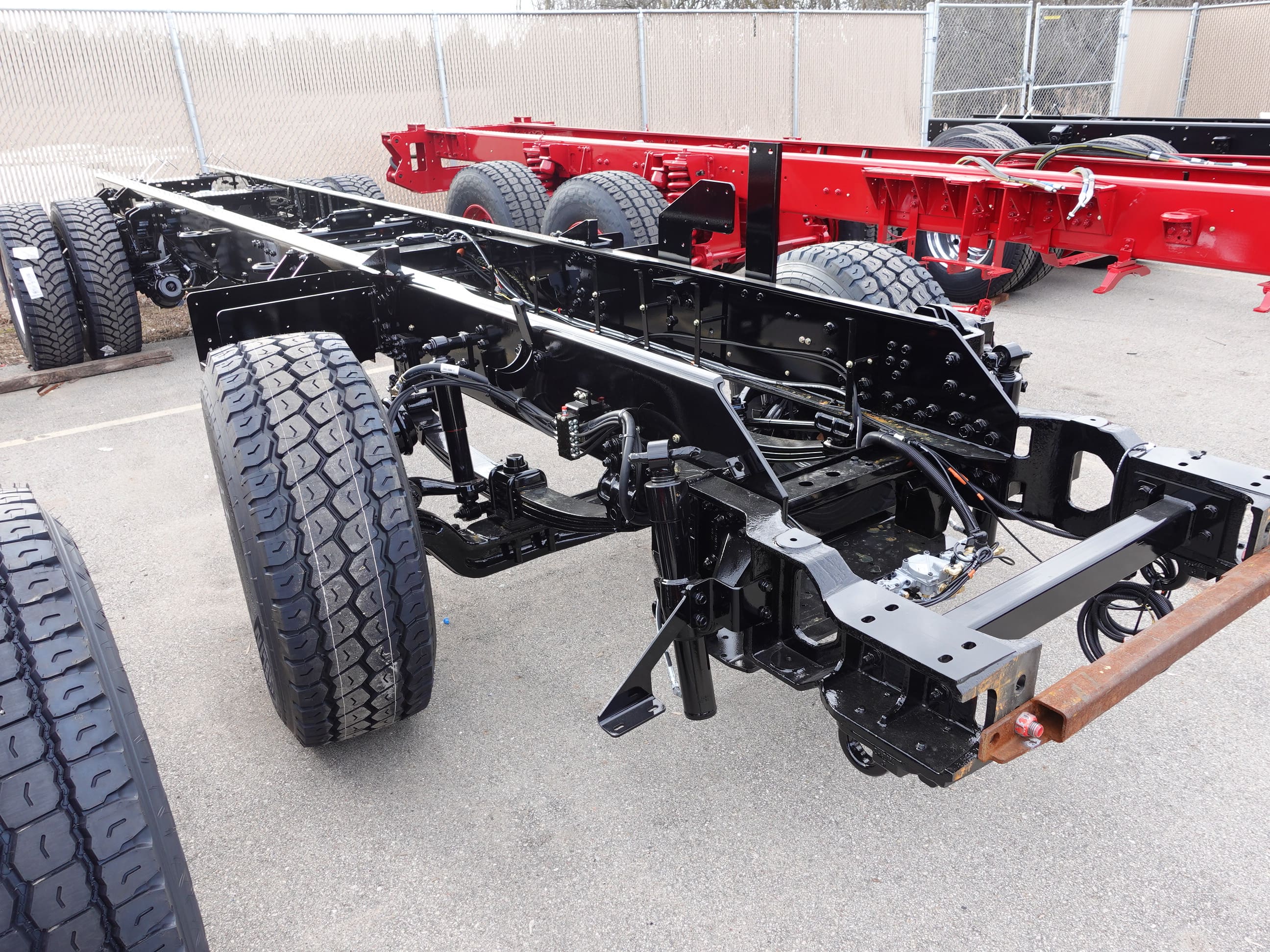

In this report, the cab completed the paint process, the frame build began, the pump house began initial assembly, and the body was unavailable for photos.

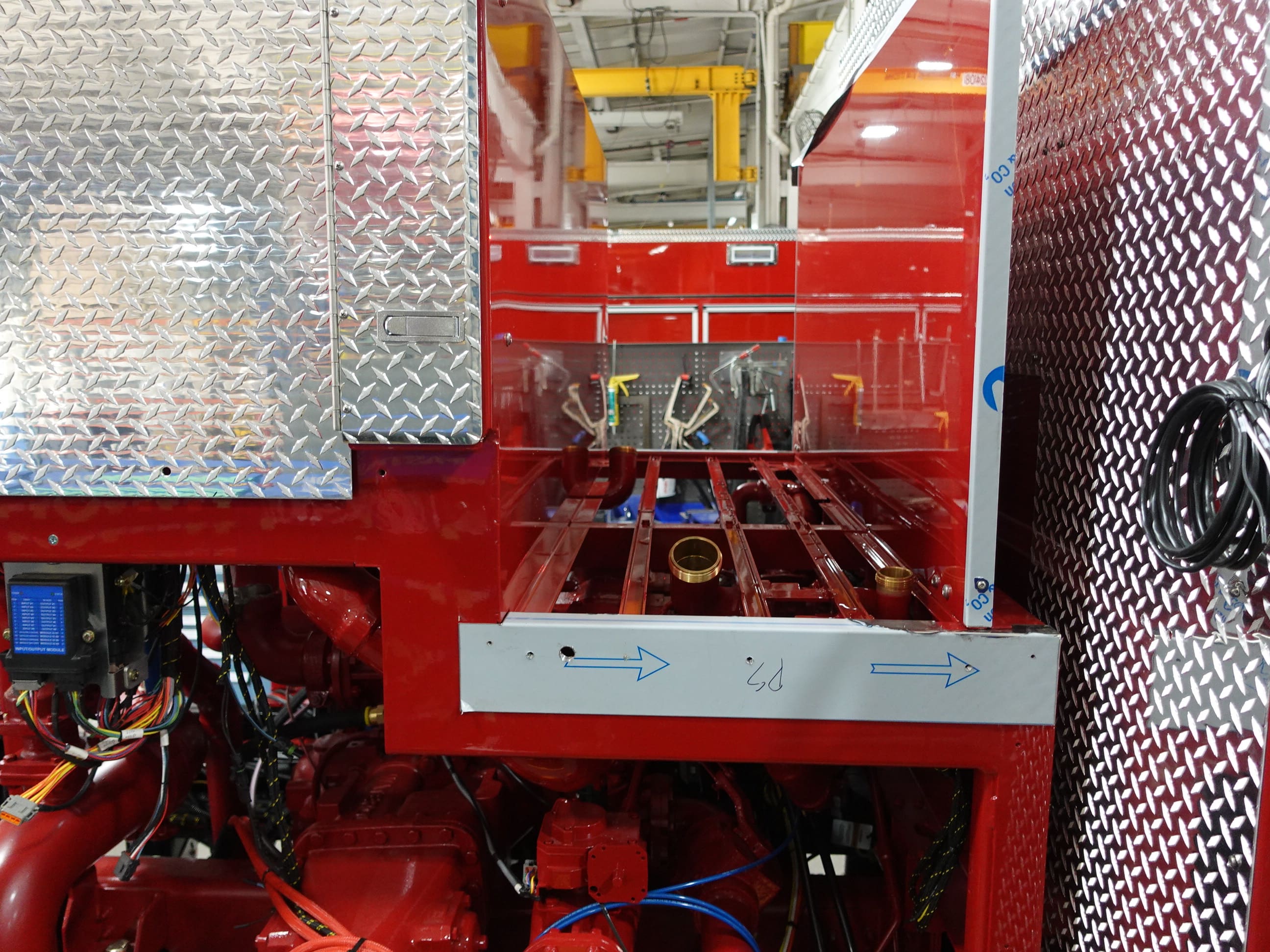

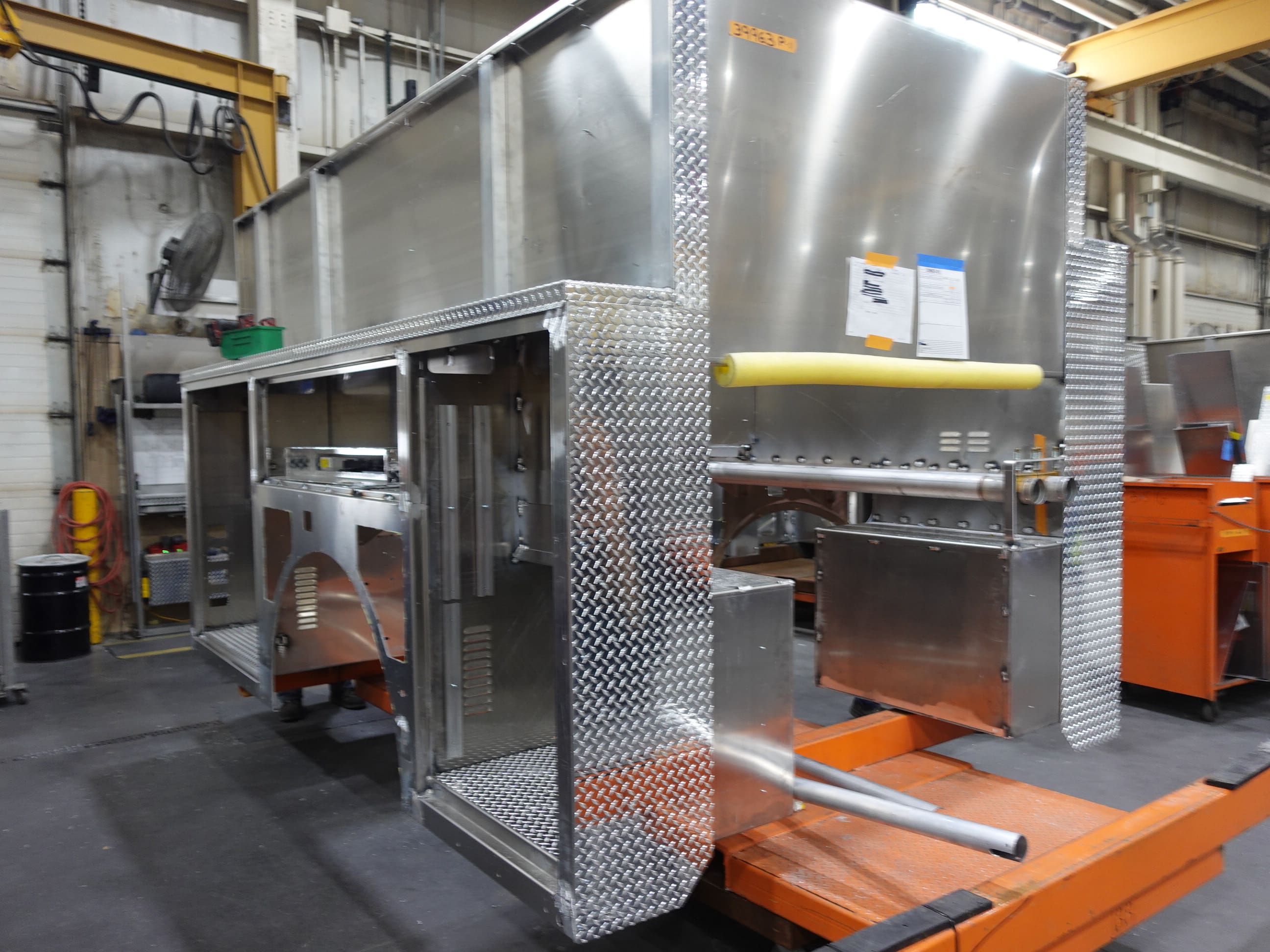

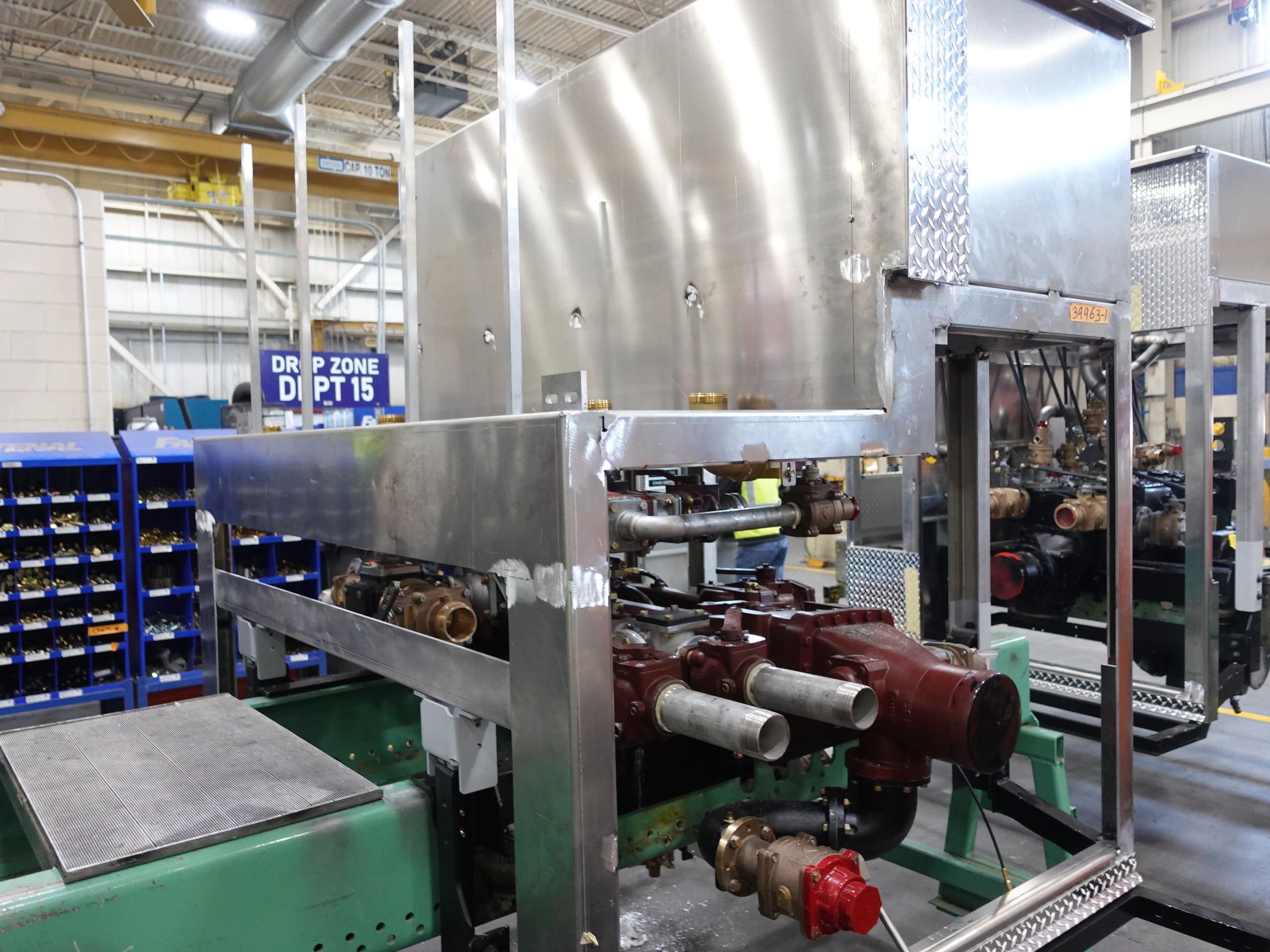

03-06-26

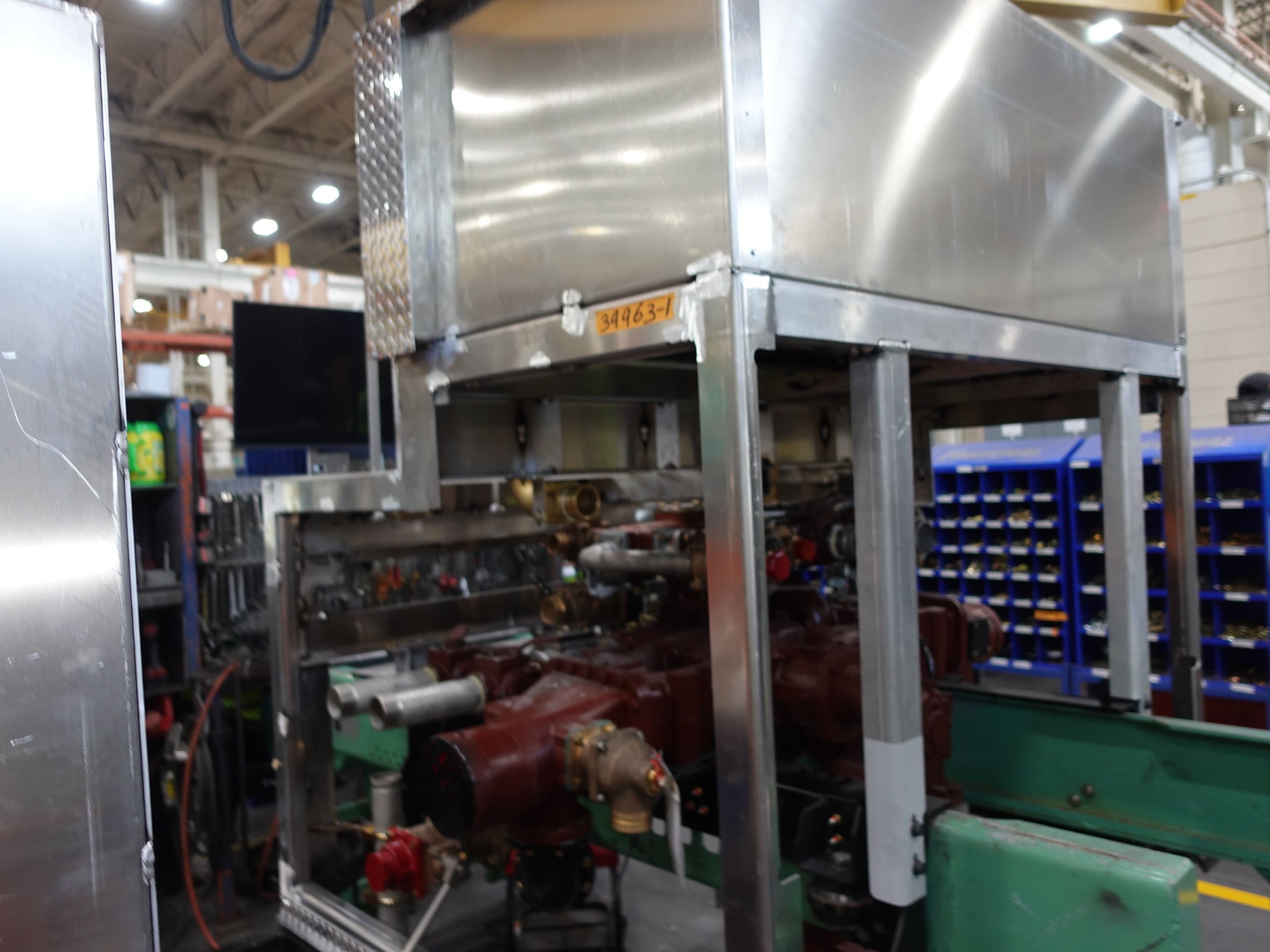

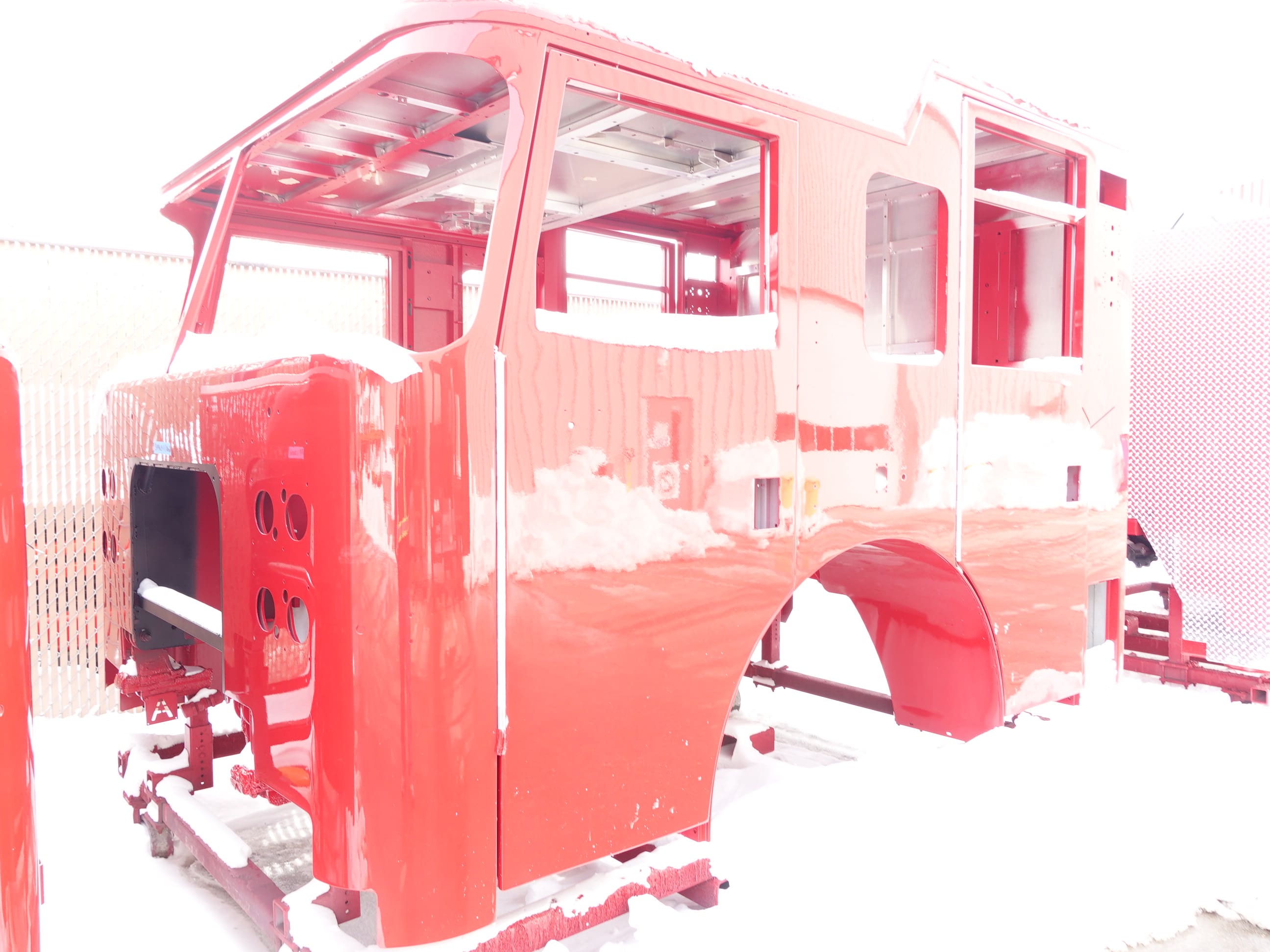

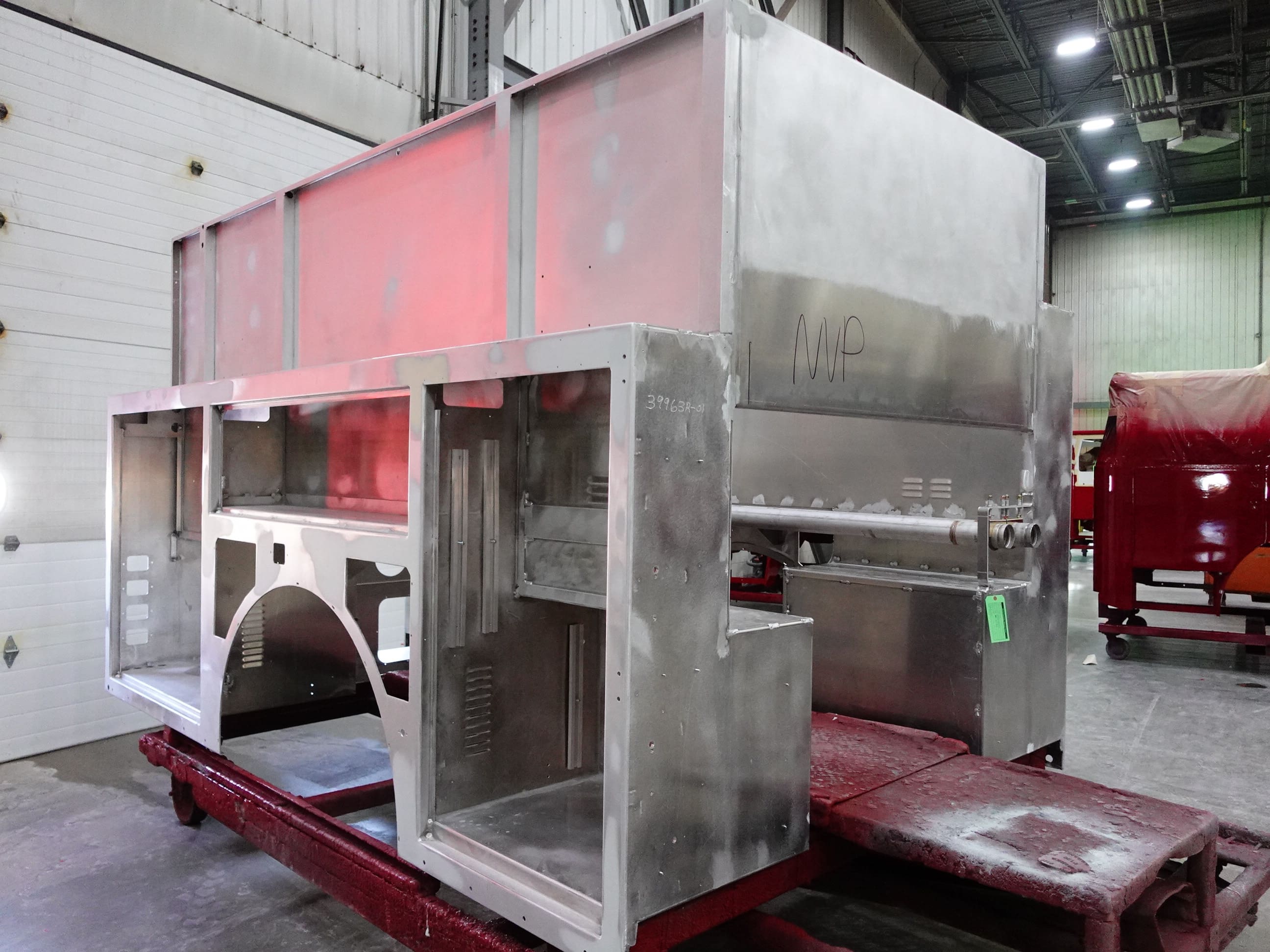

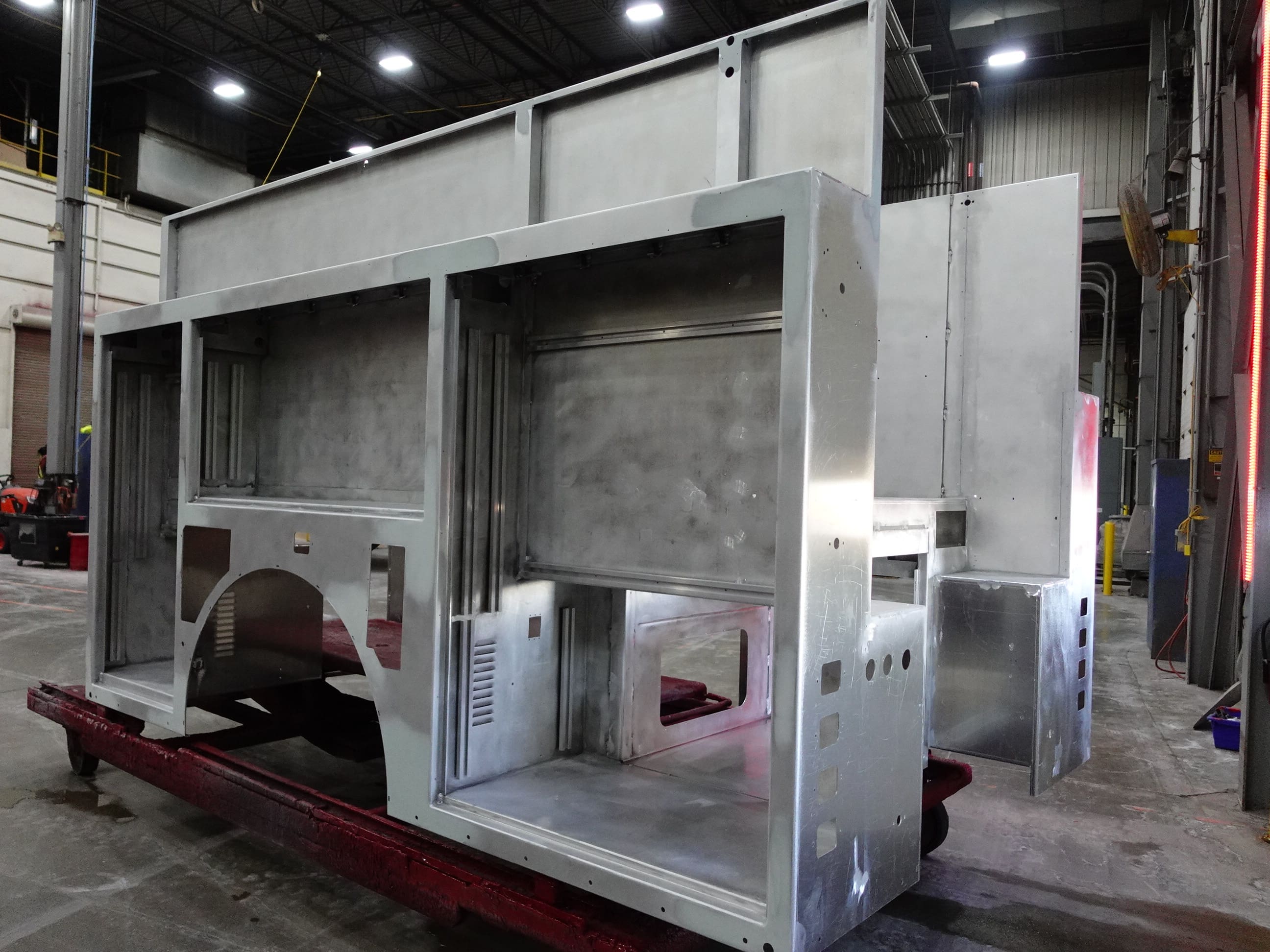

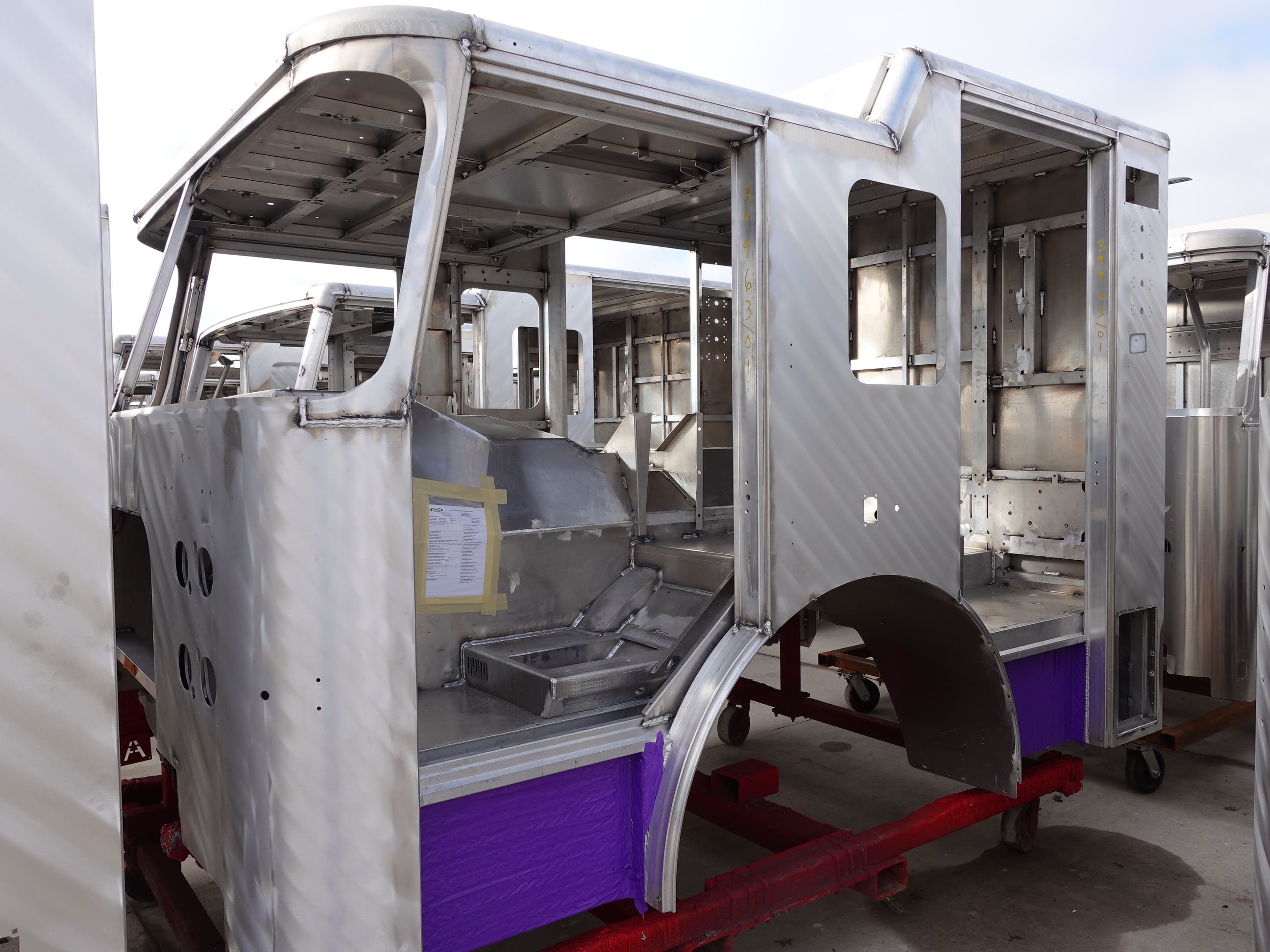

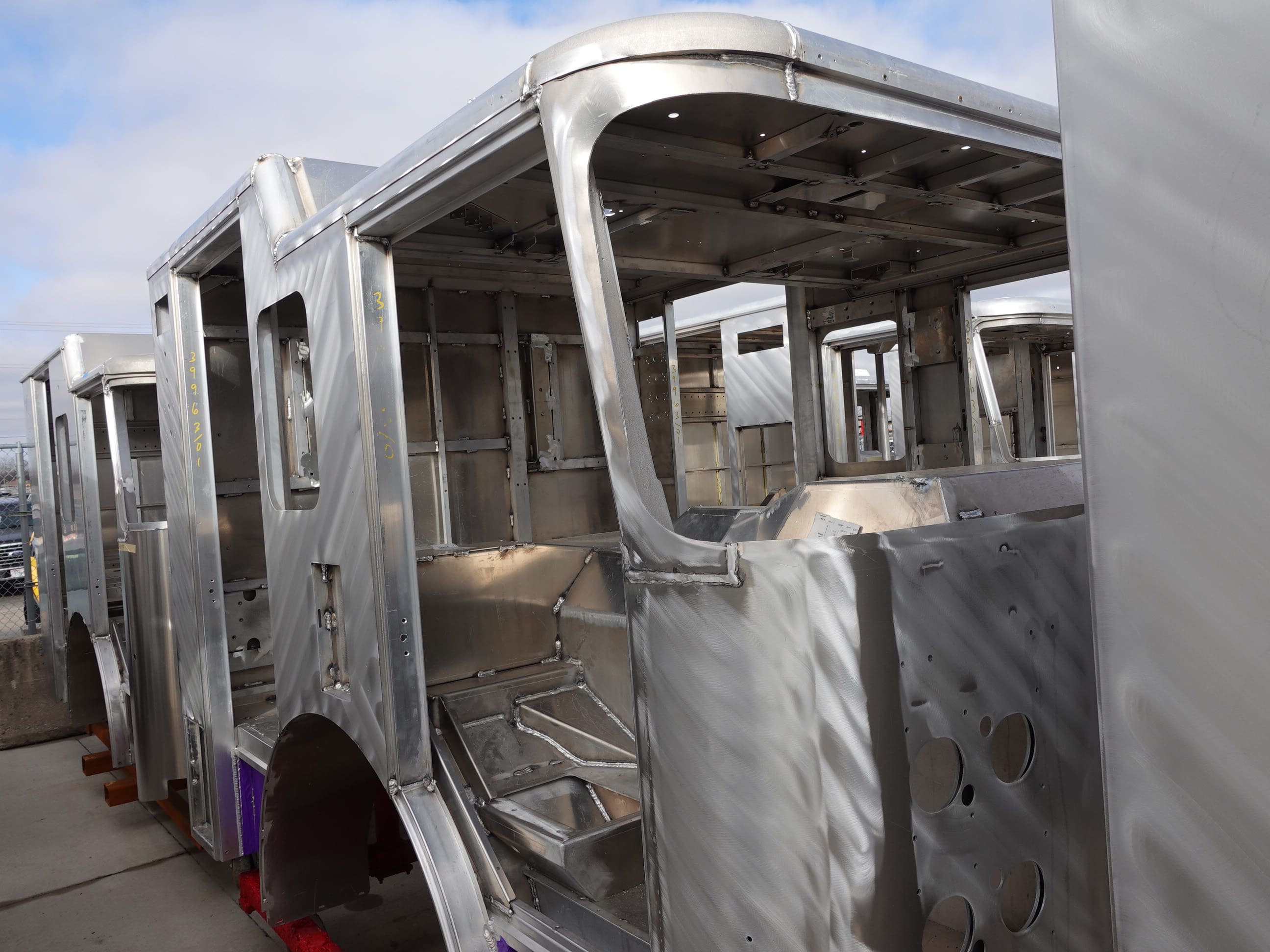

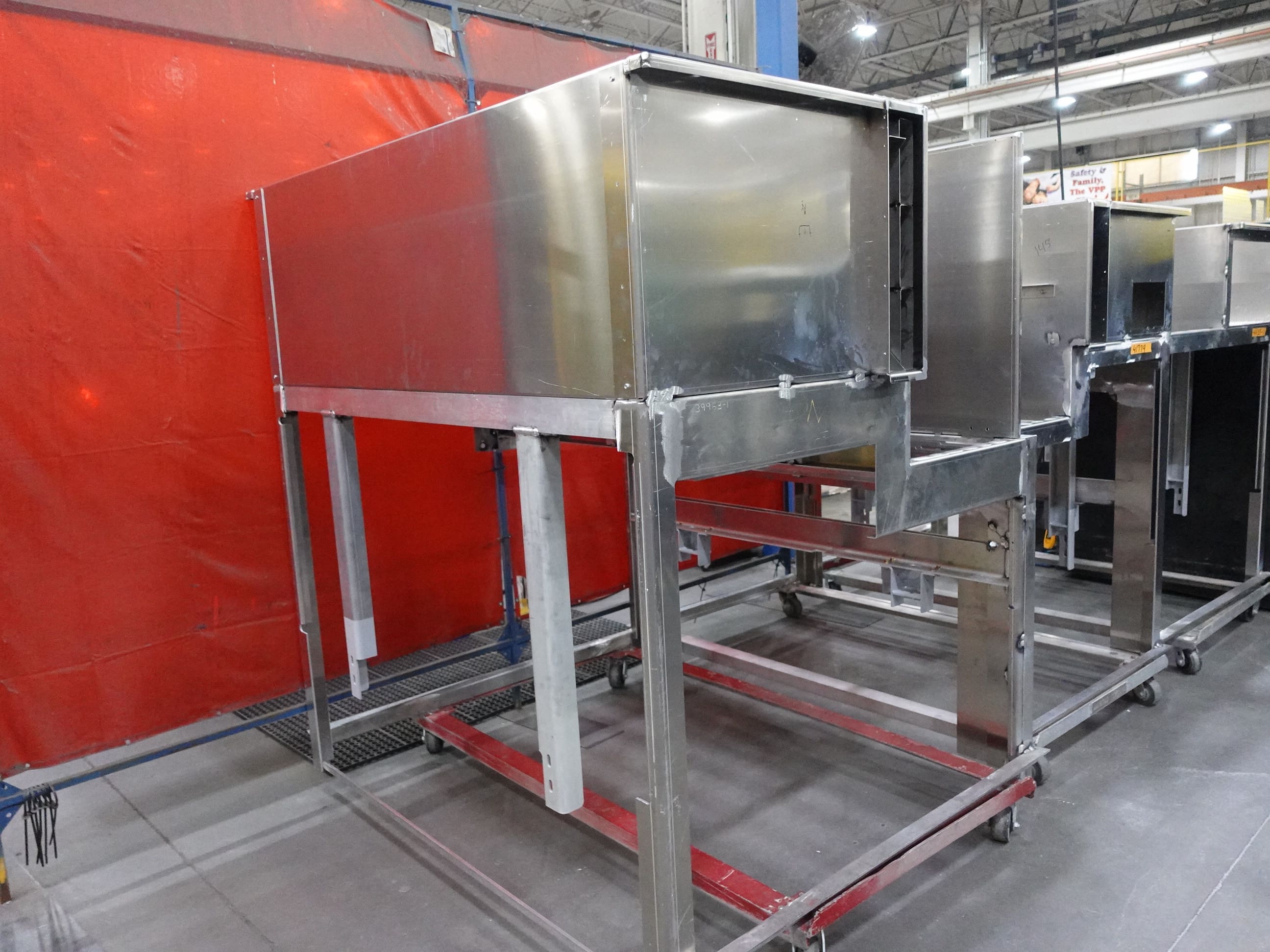

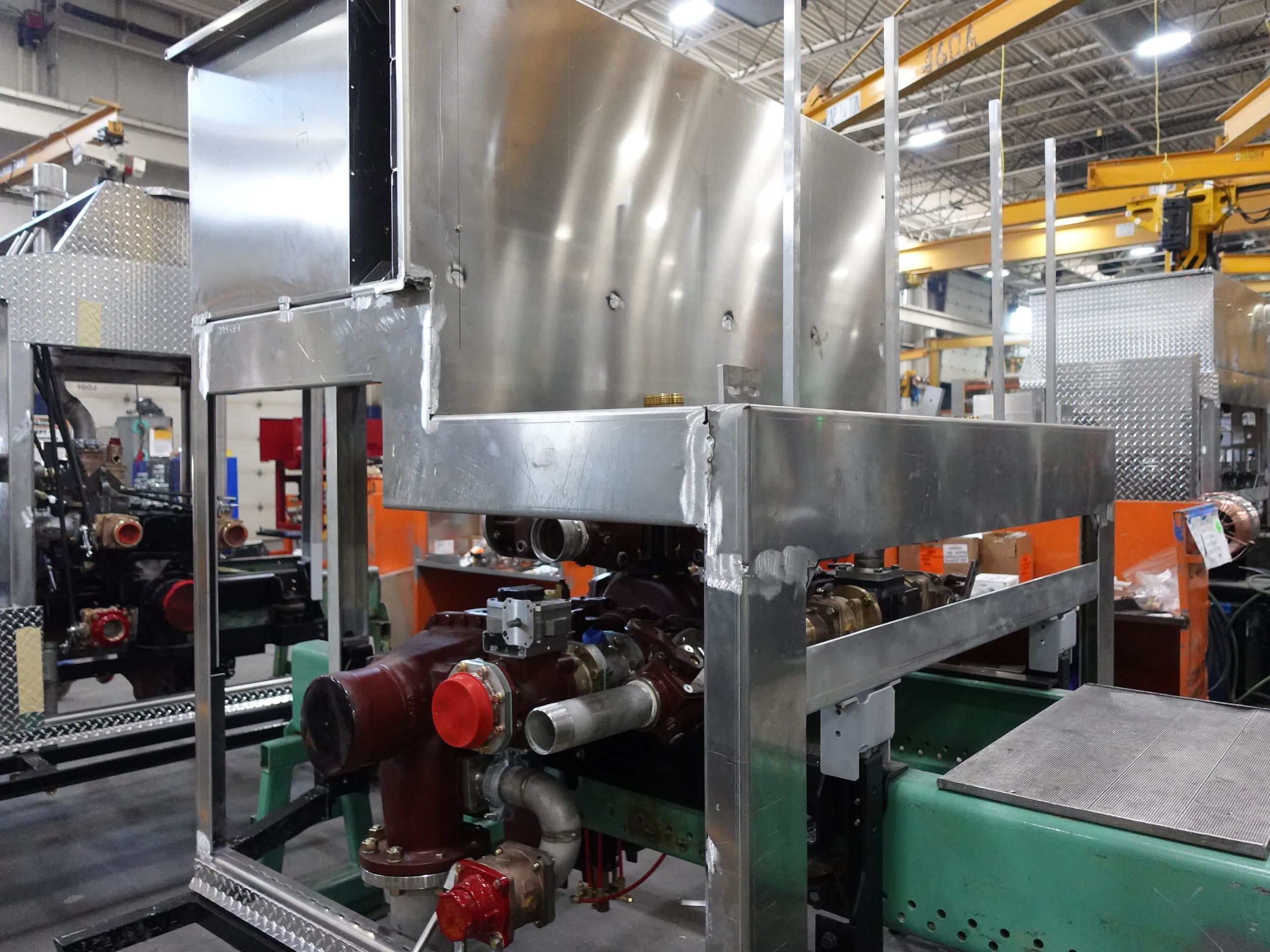

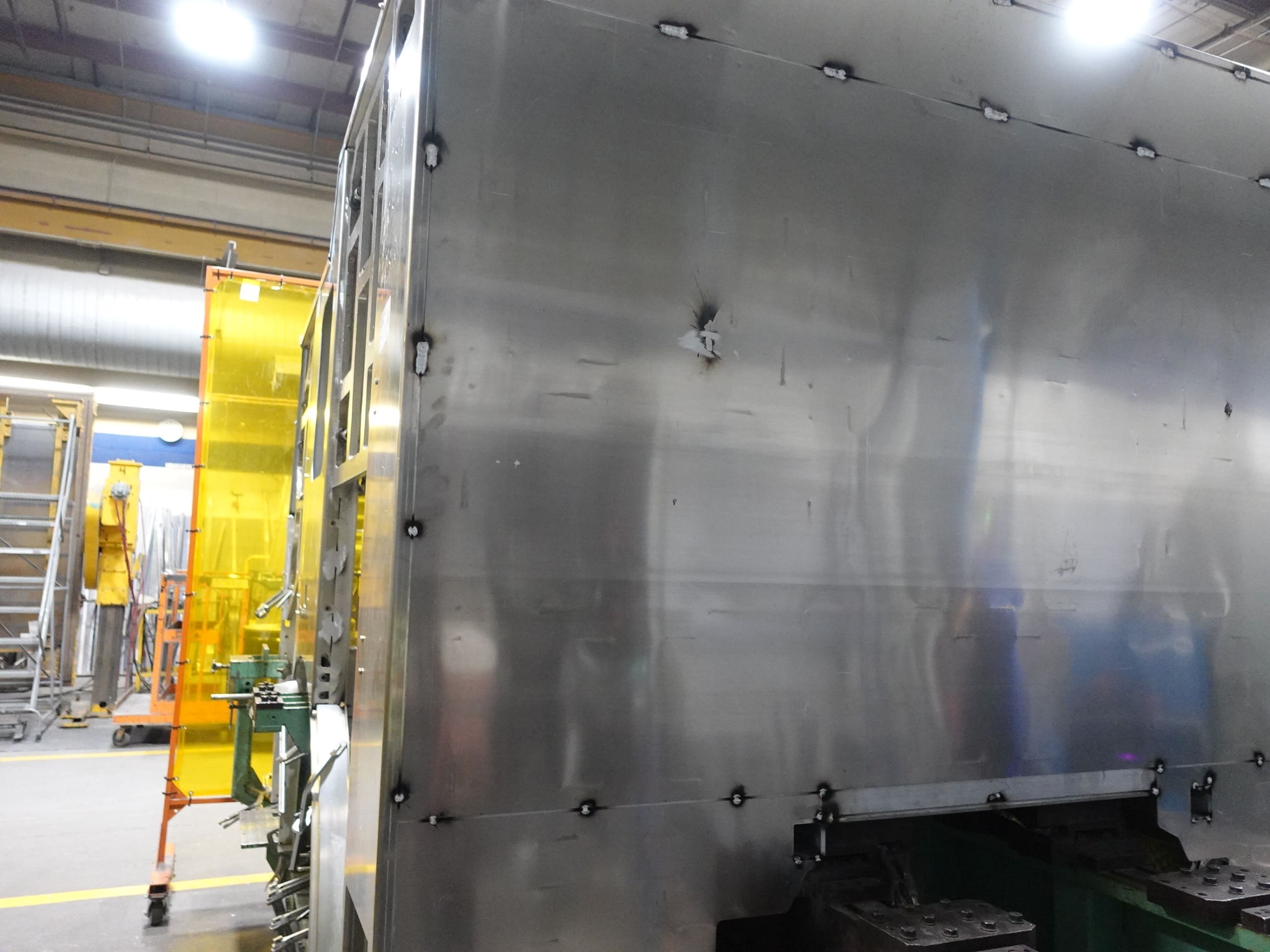

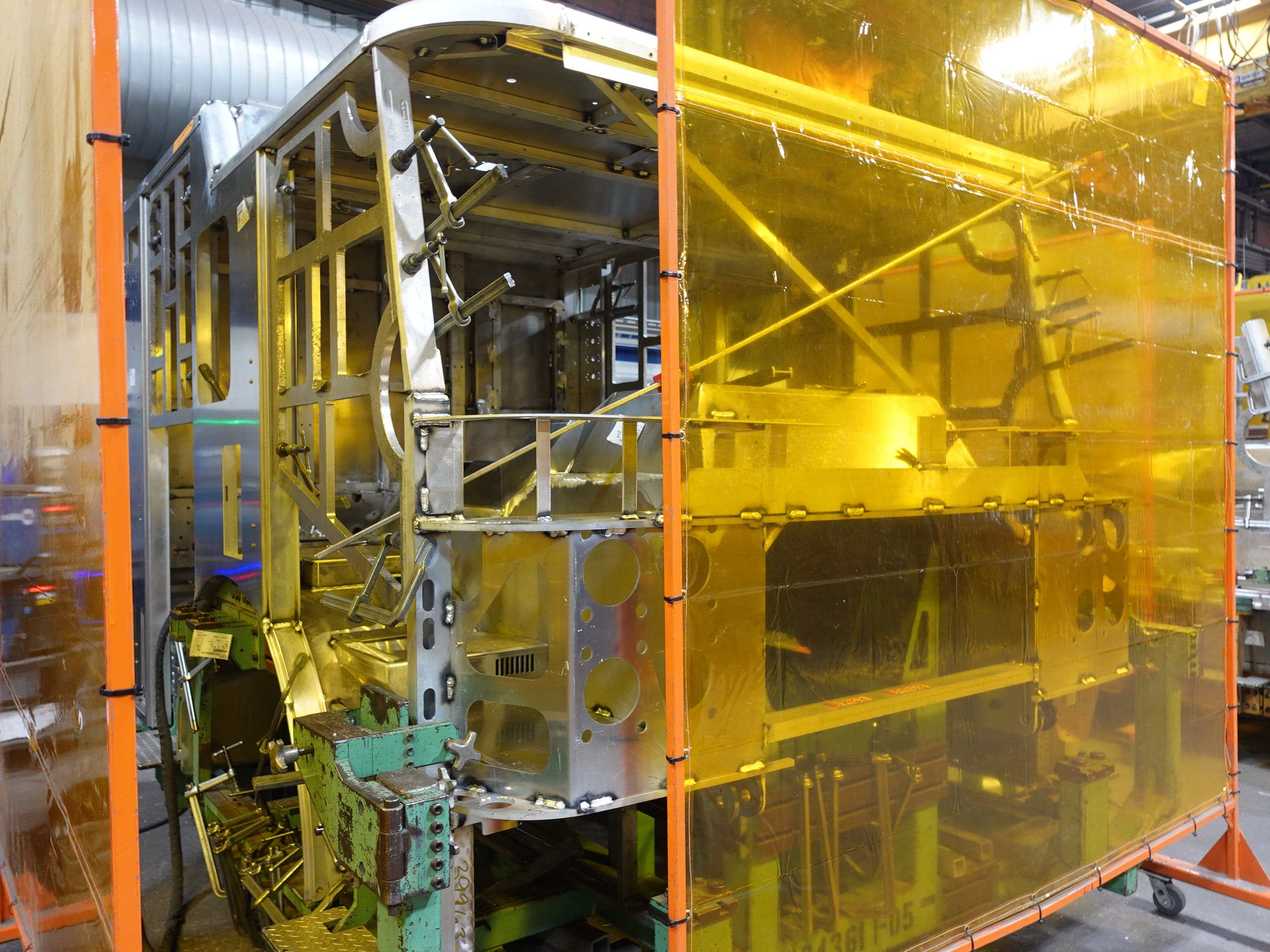

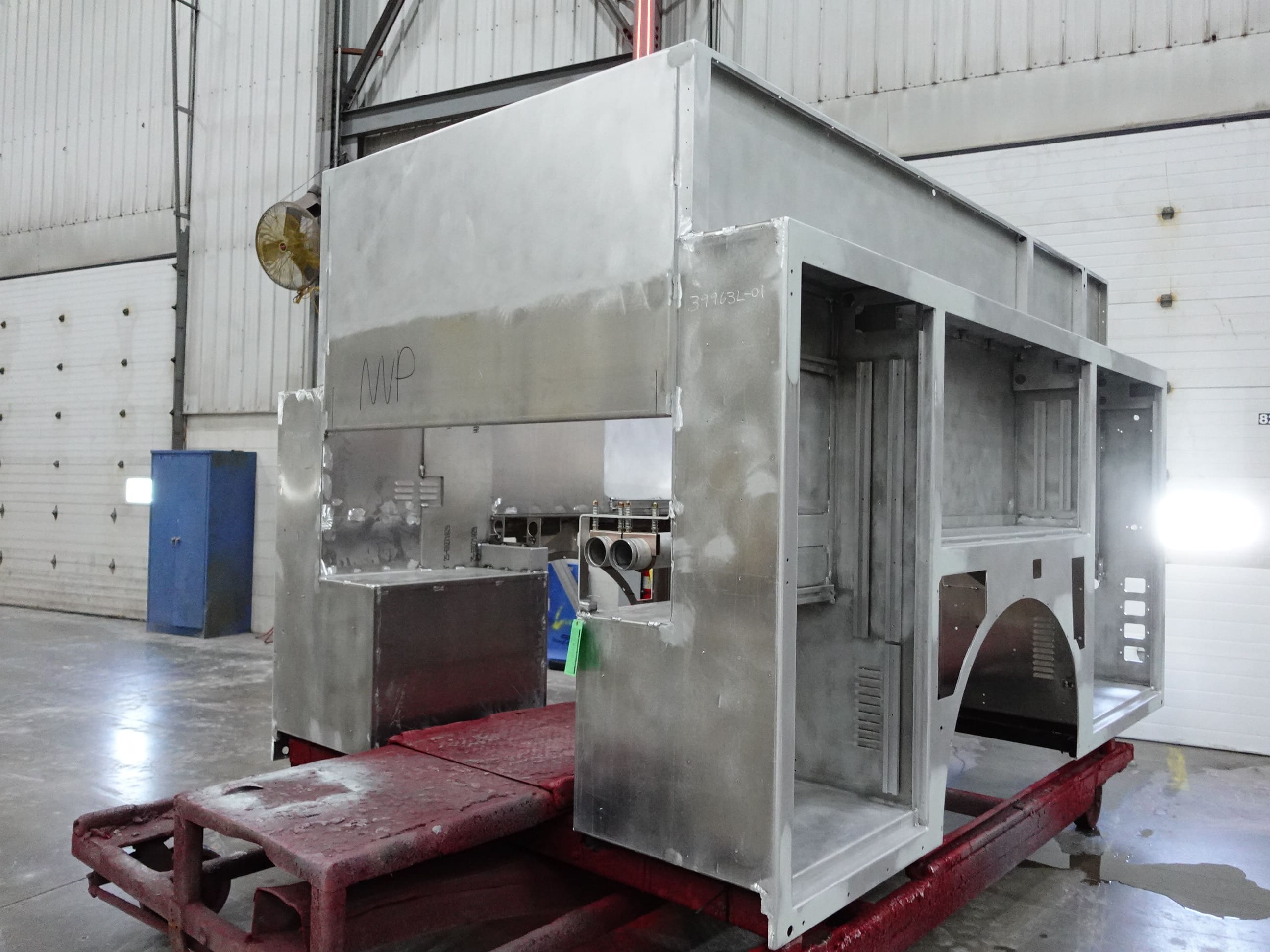

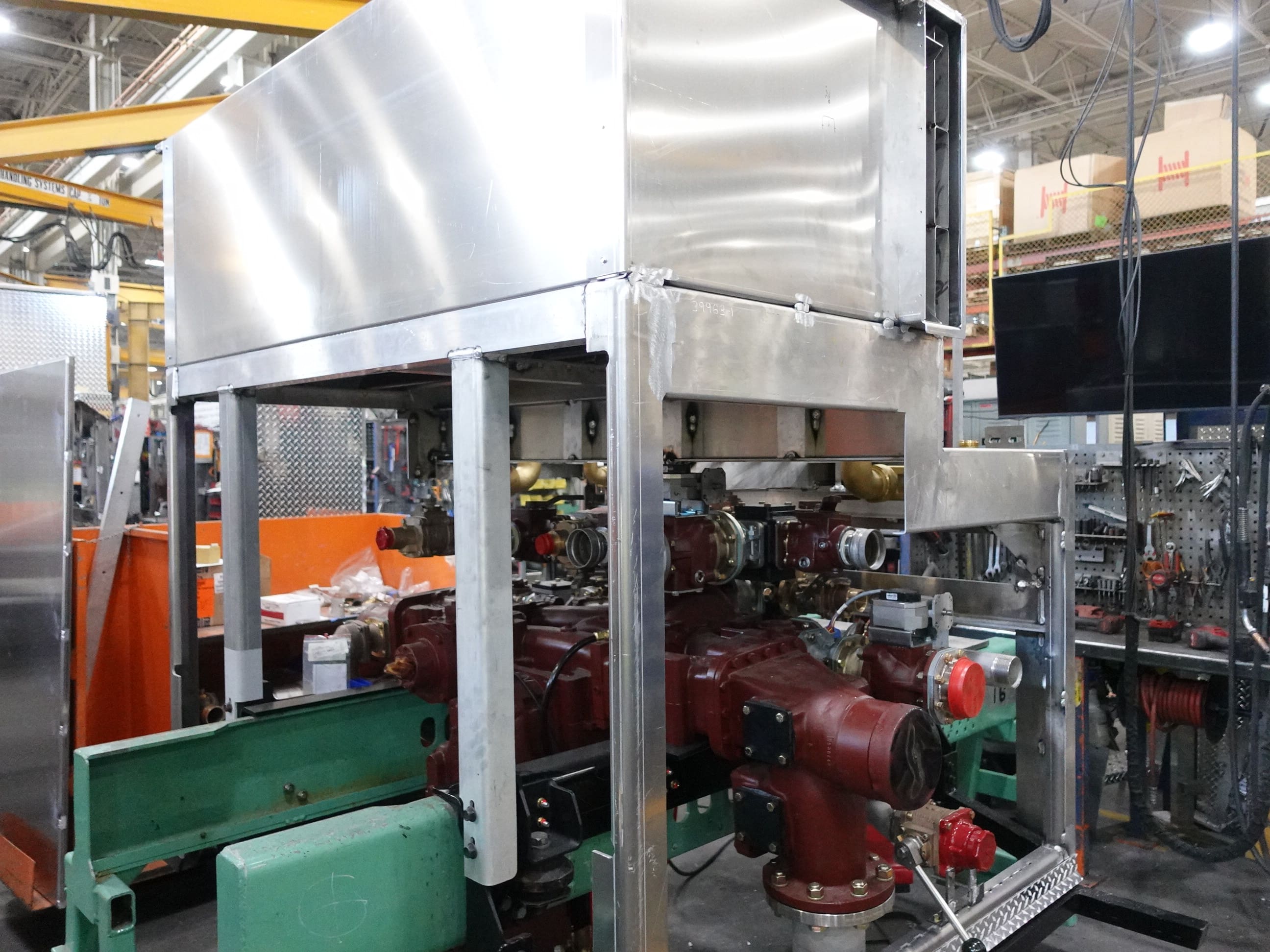

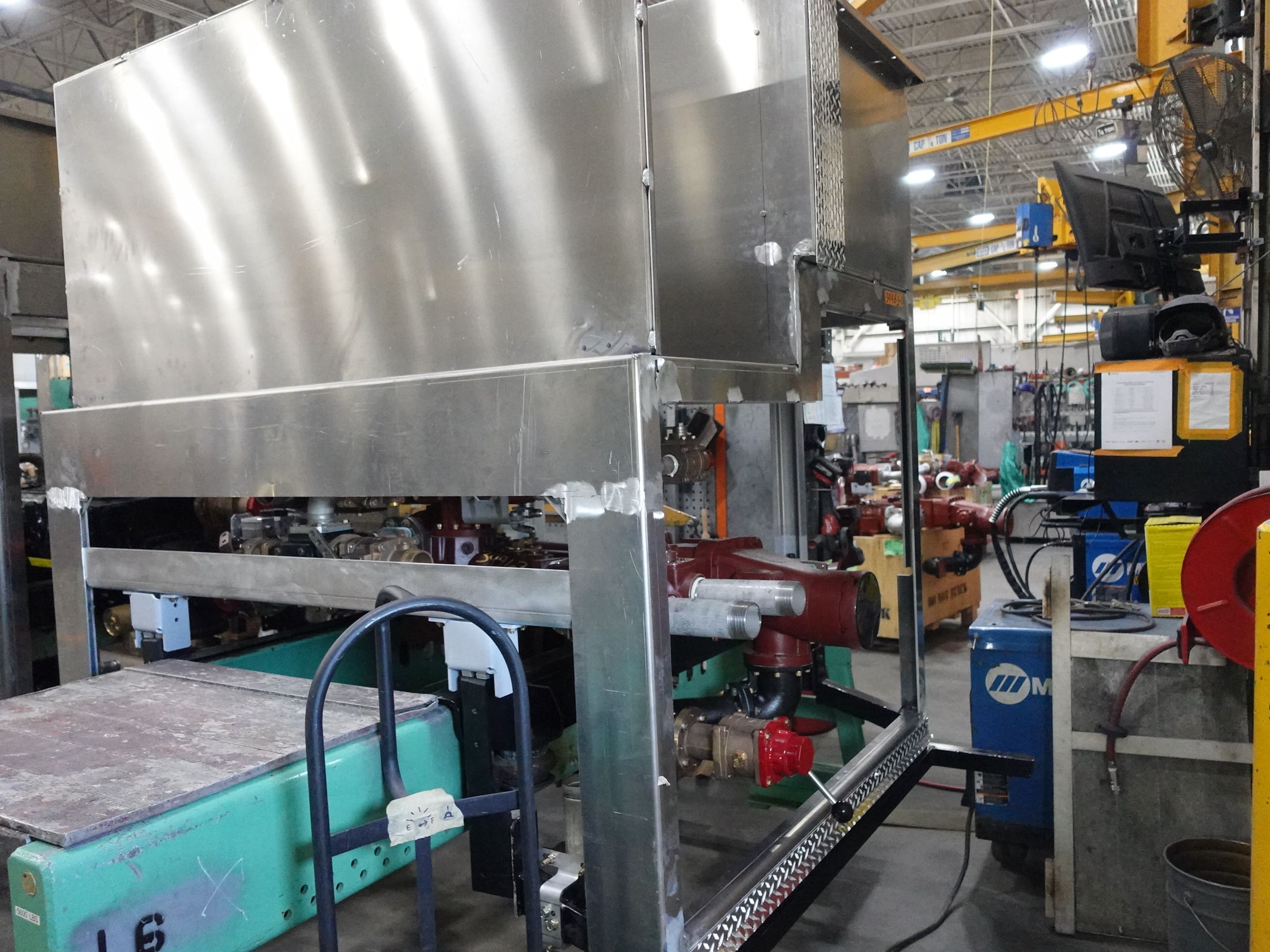

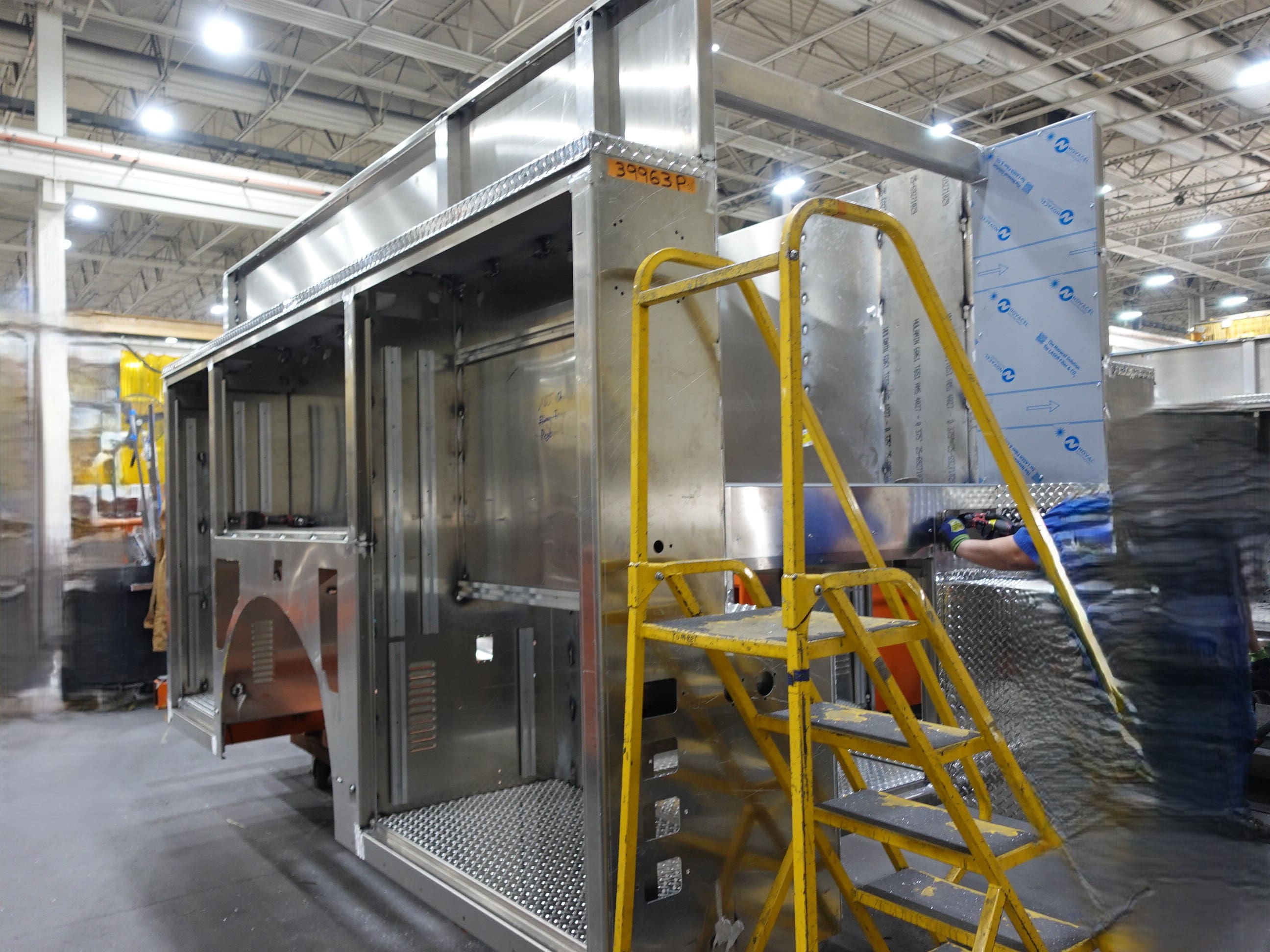

In this report, the cab continued the paint process, the pump house structure was fabricated, and the body began fabrication.

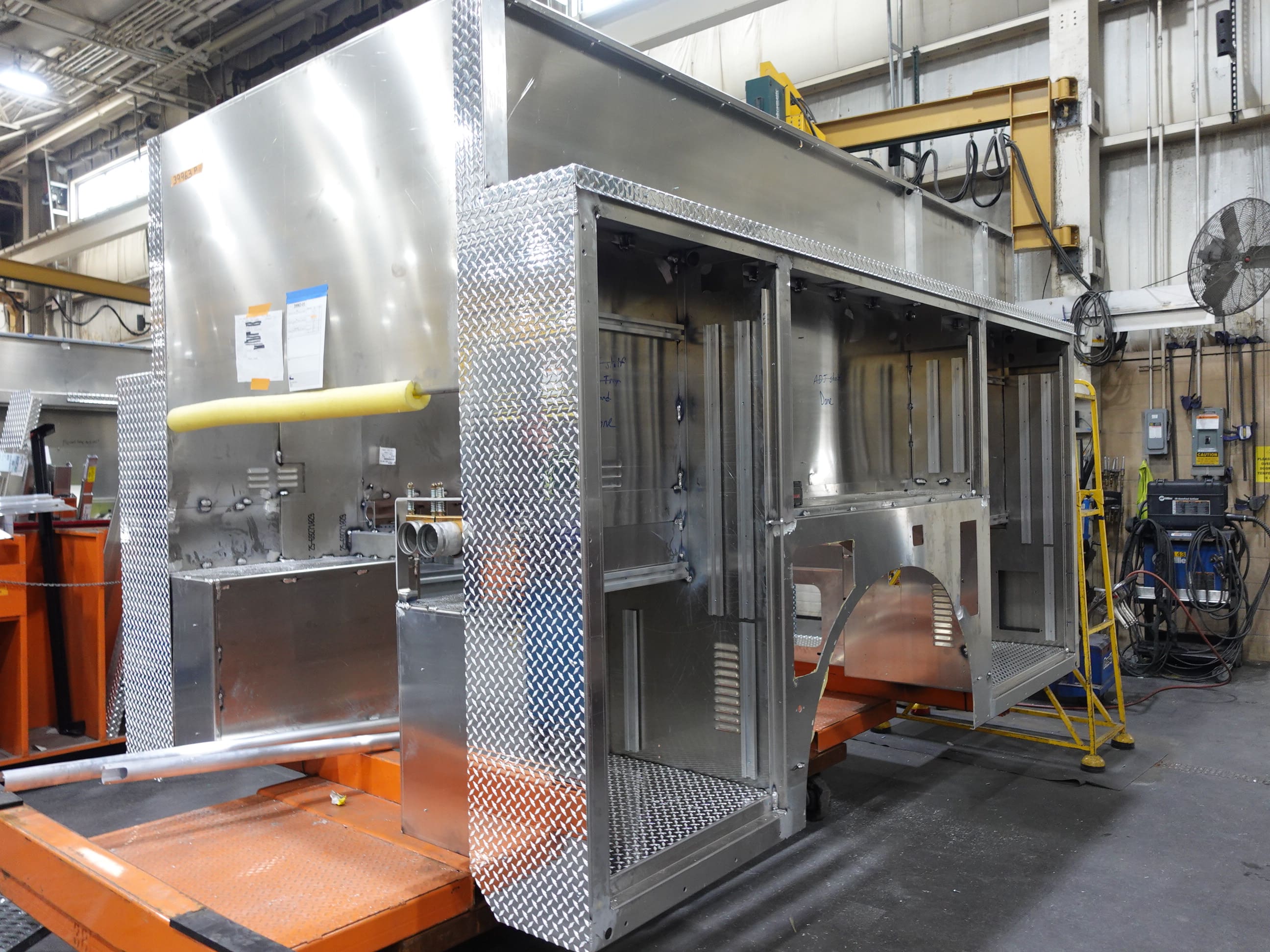

02-20-26

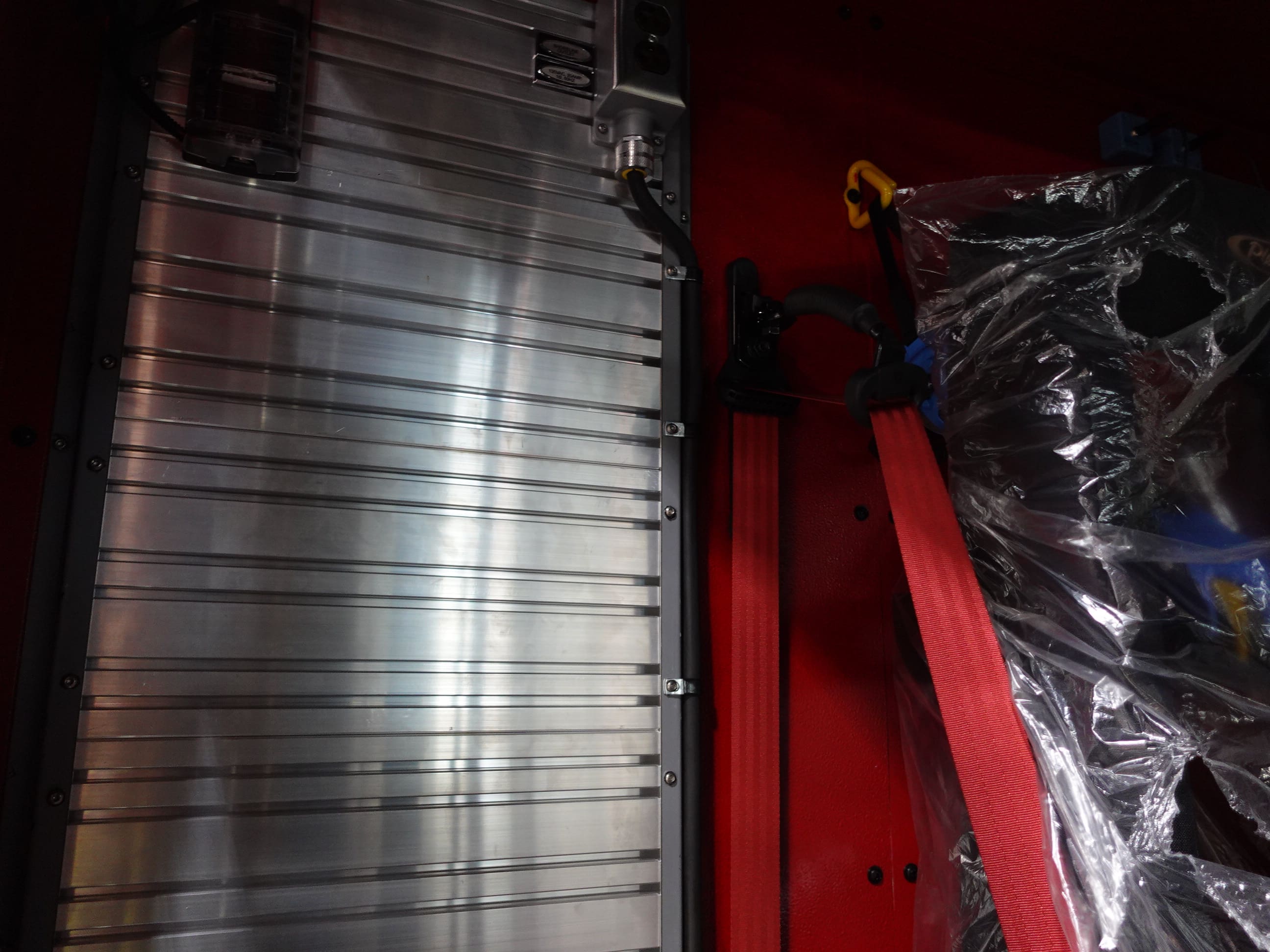

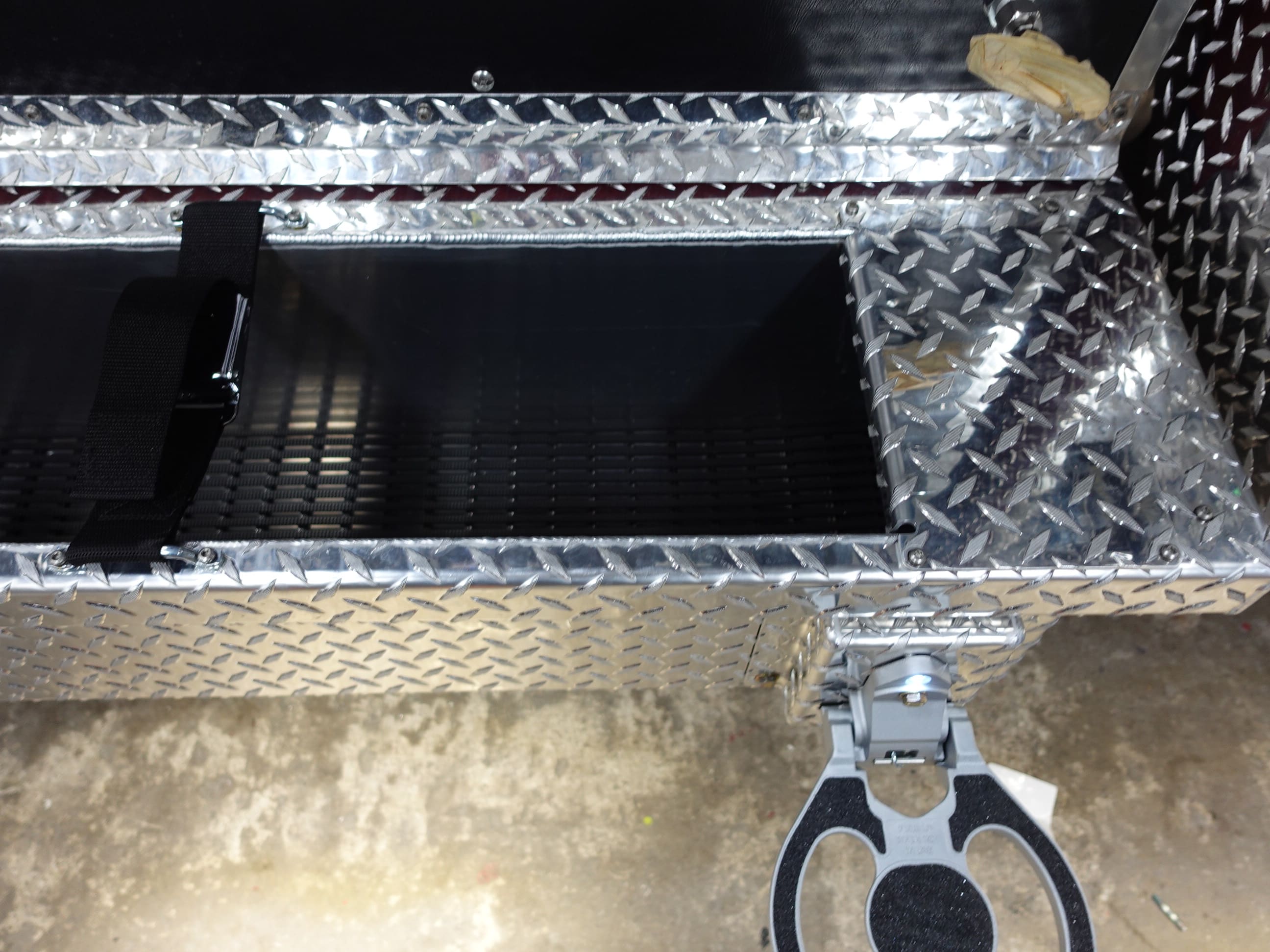

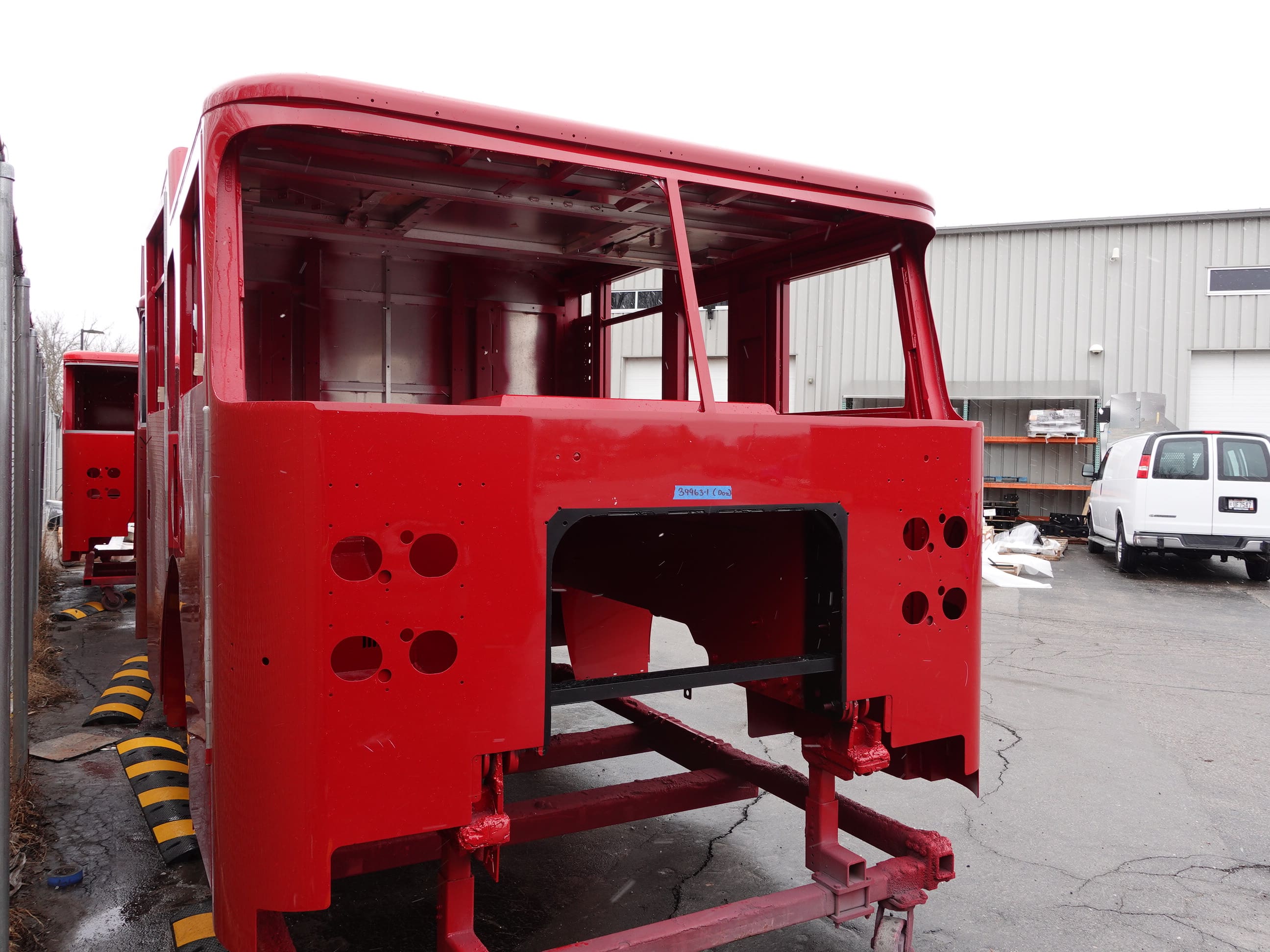

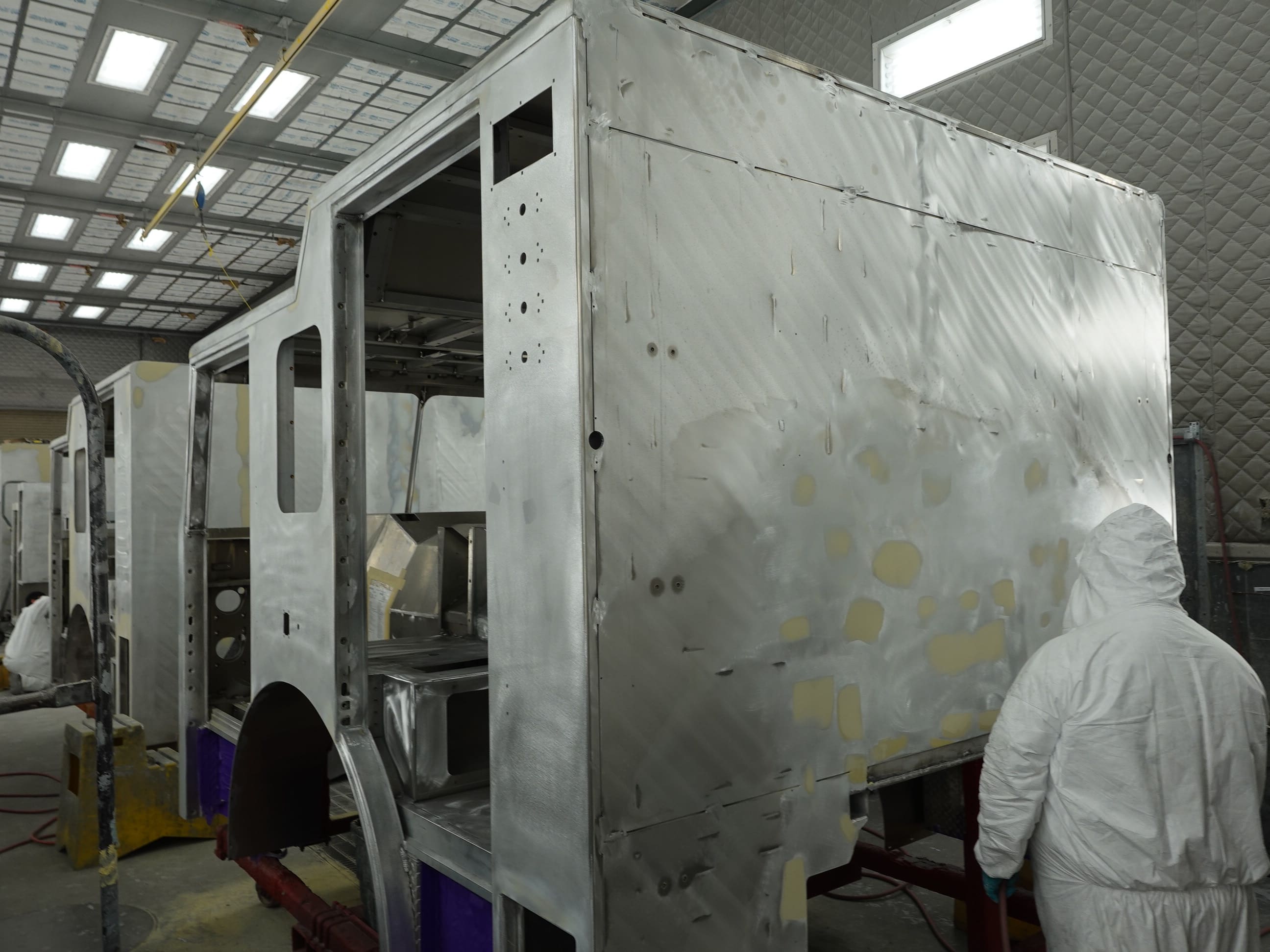

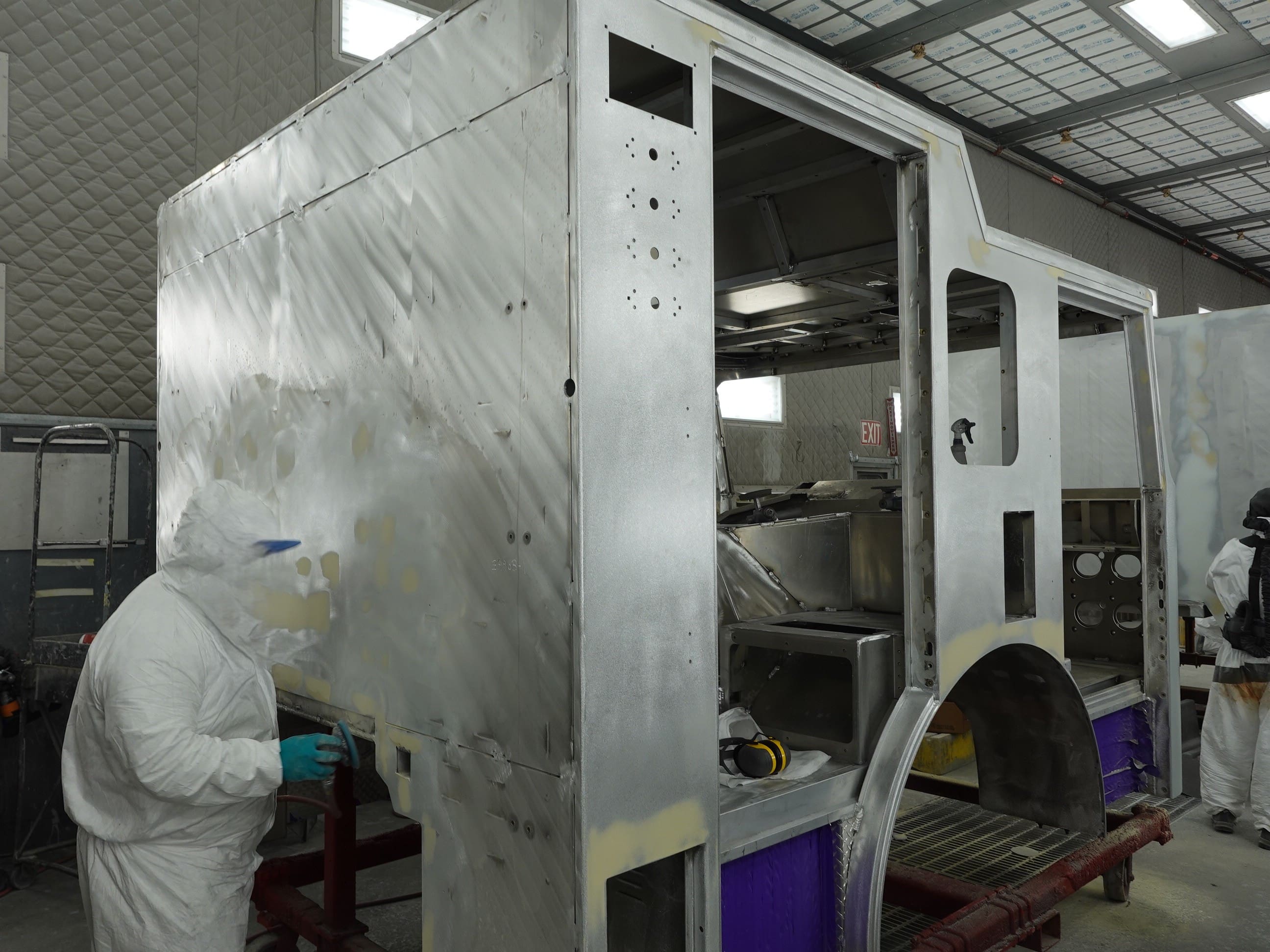

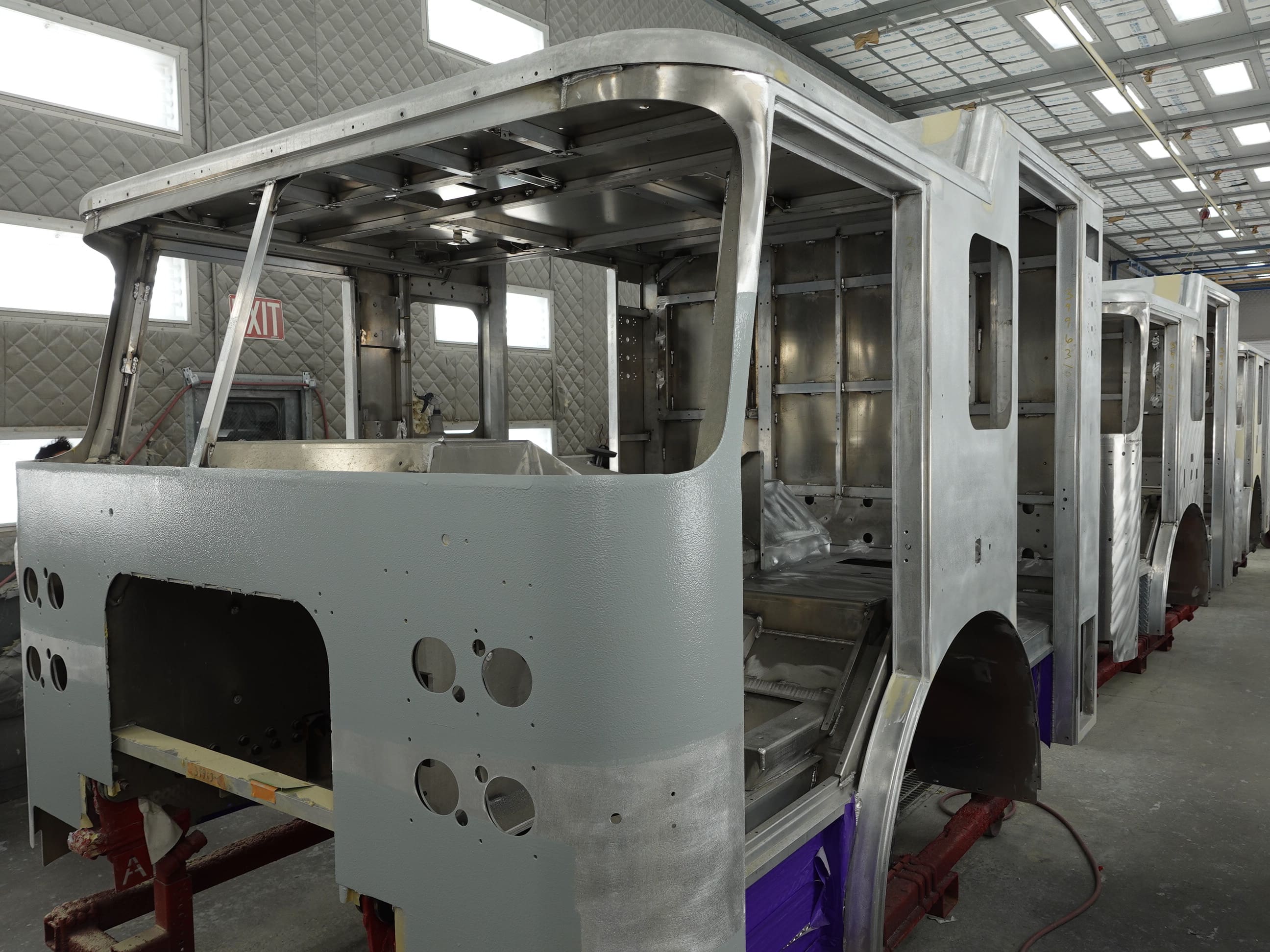

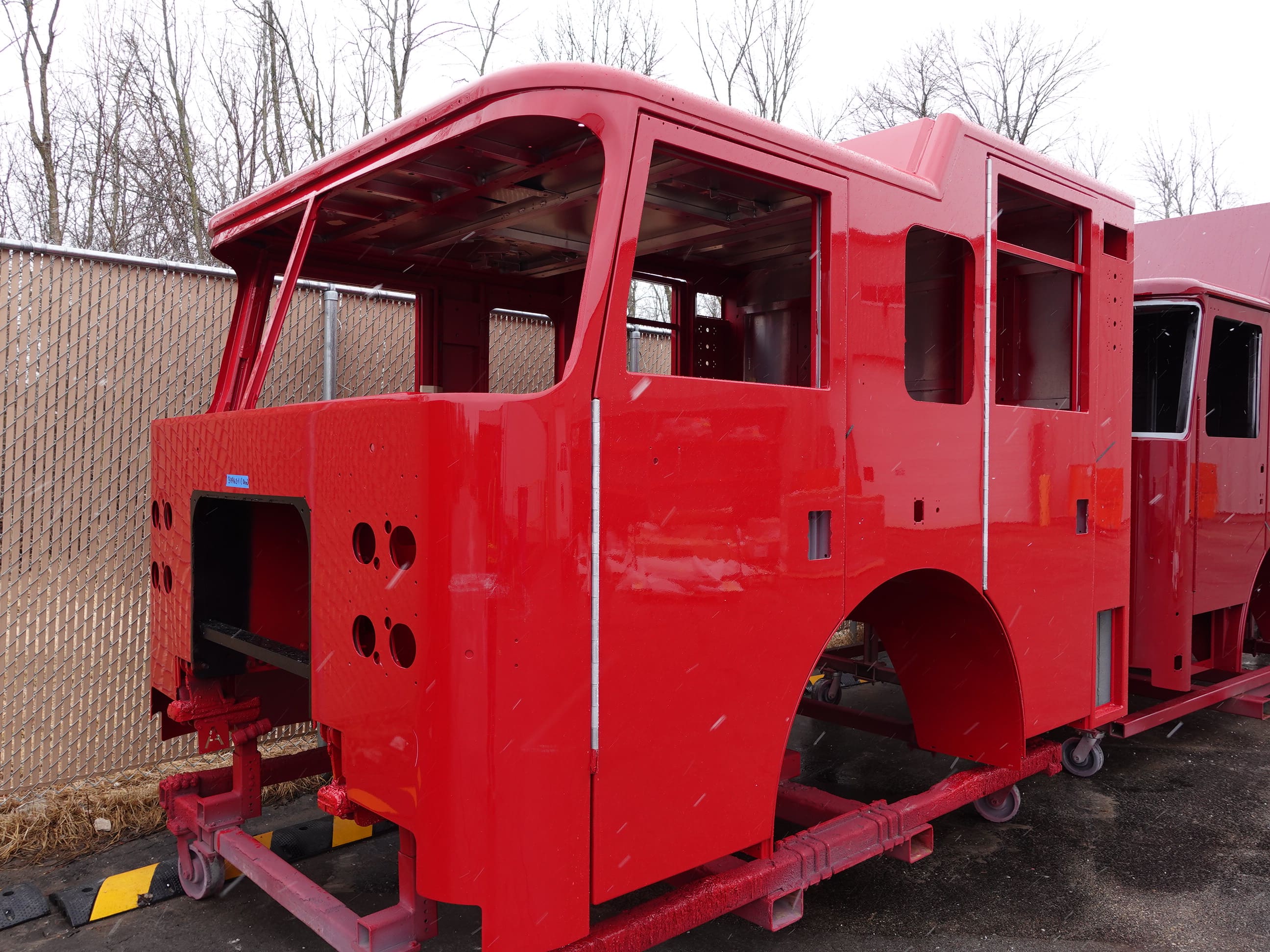

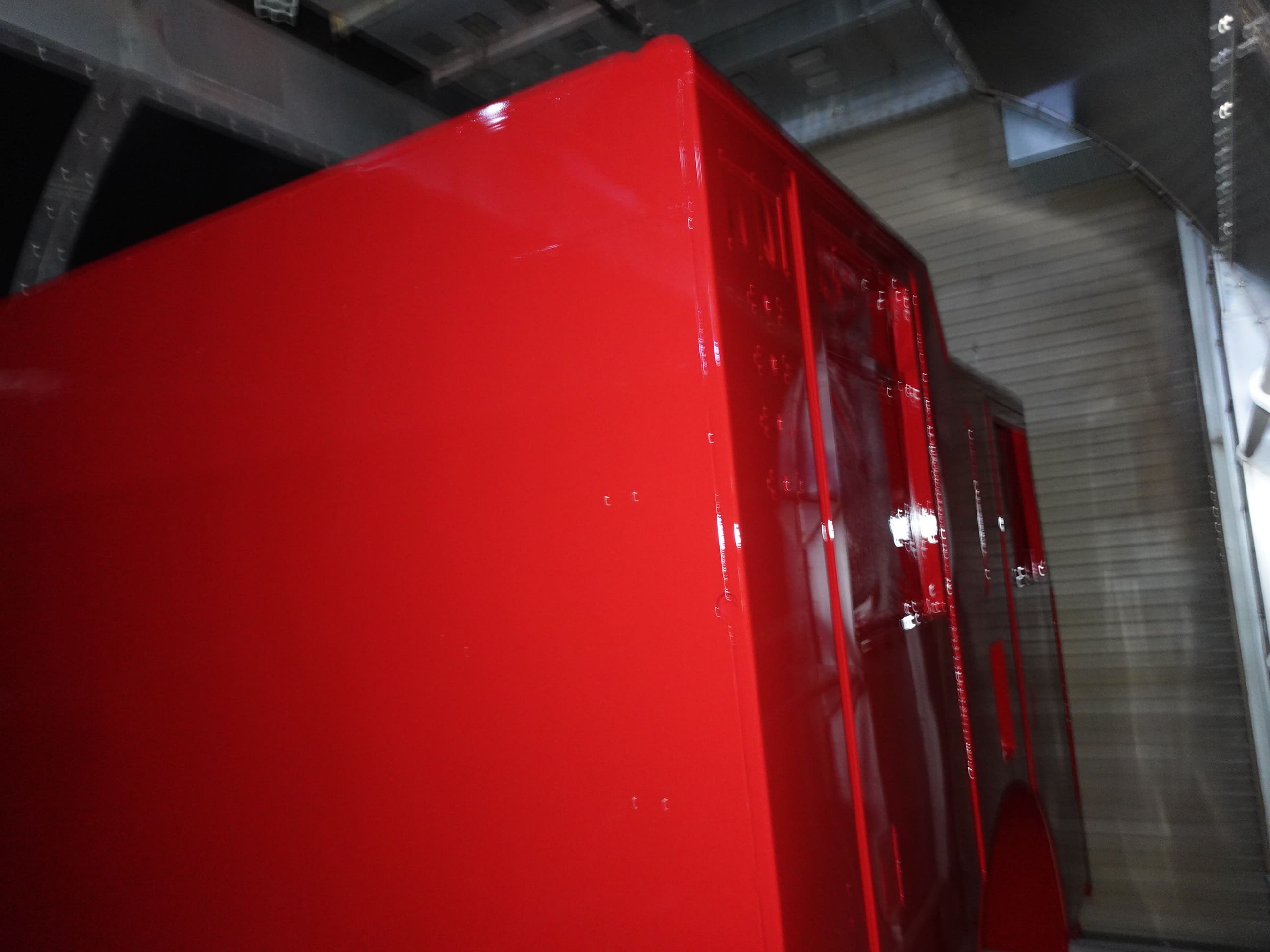

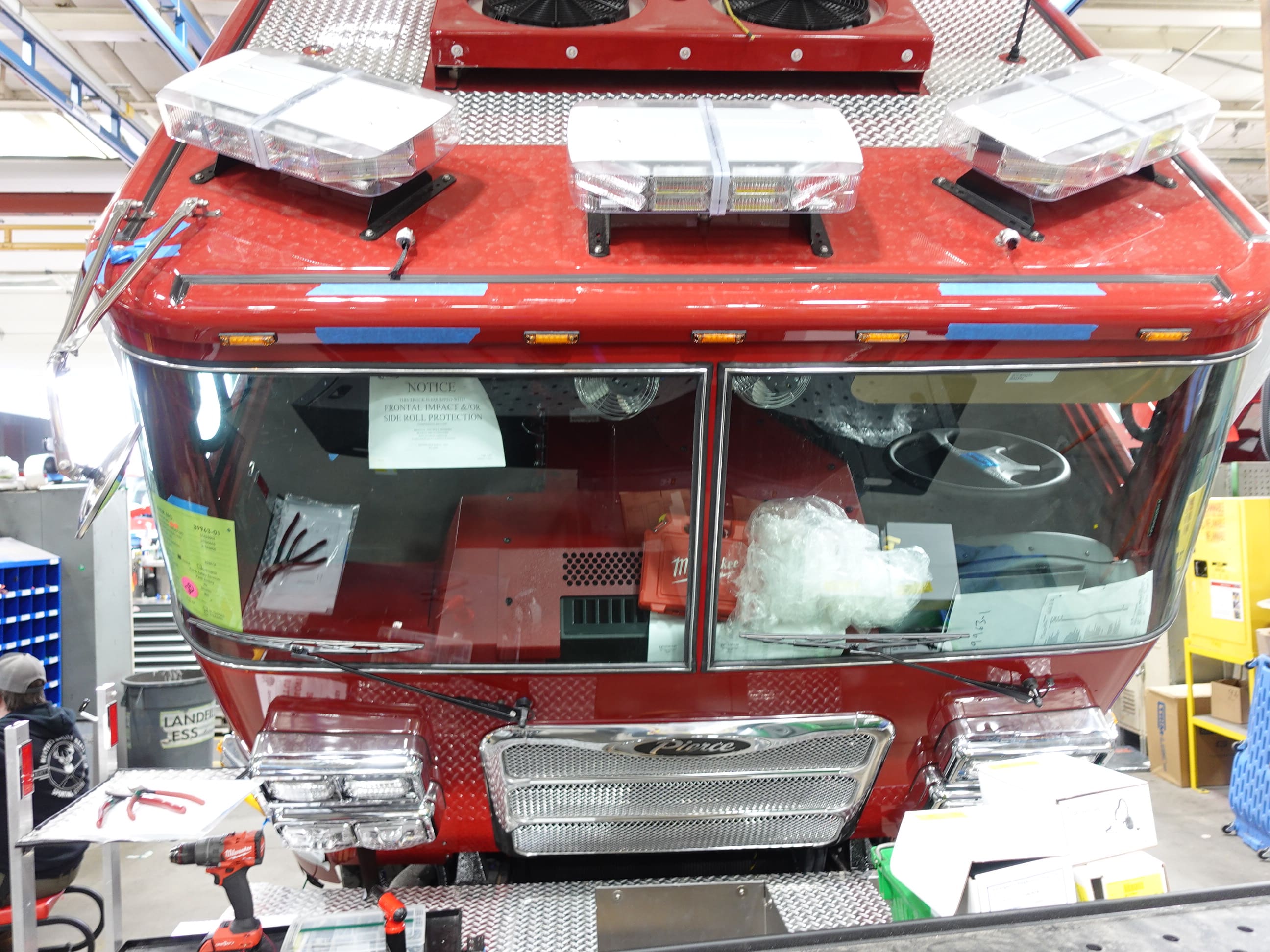

In this report, the cab completed fabrication and began the paint process with metal finishing.

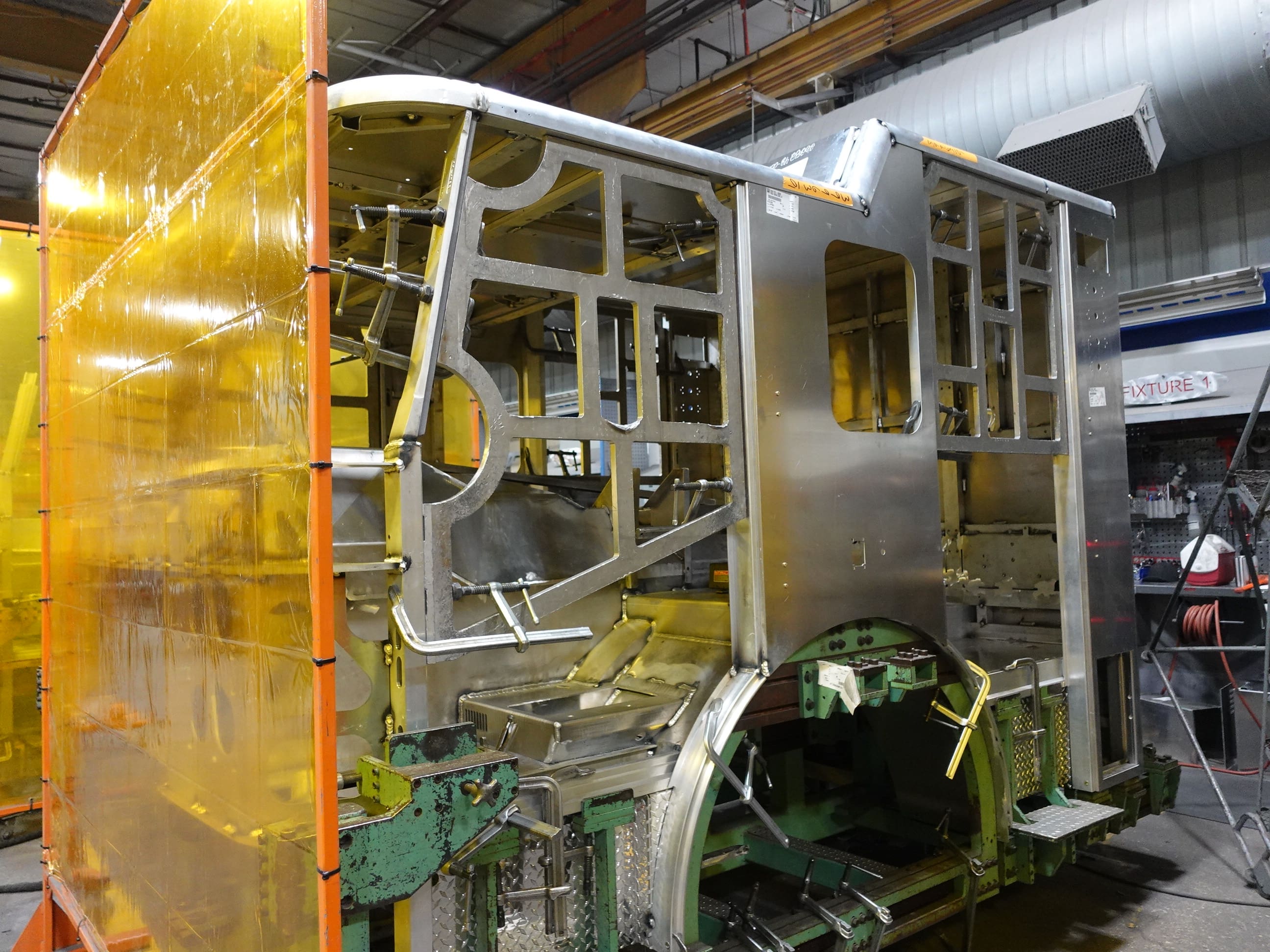

02-13-26

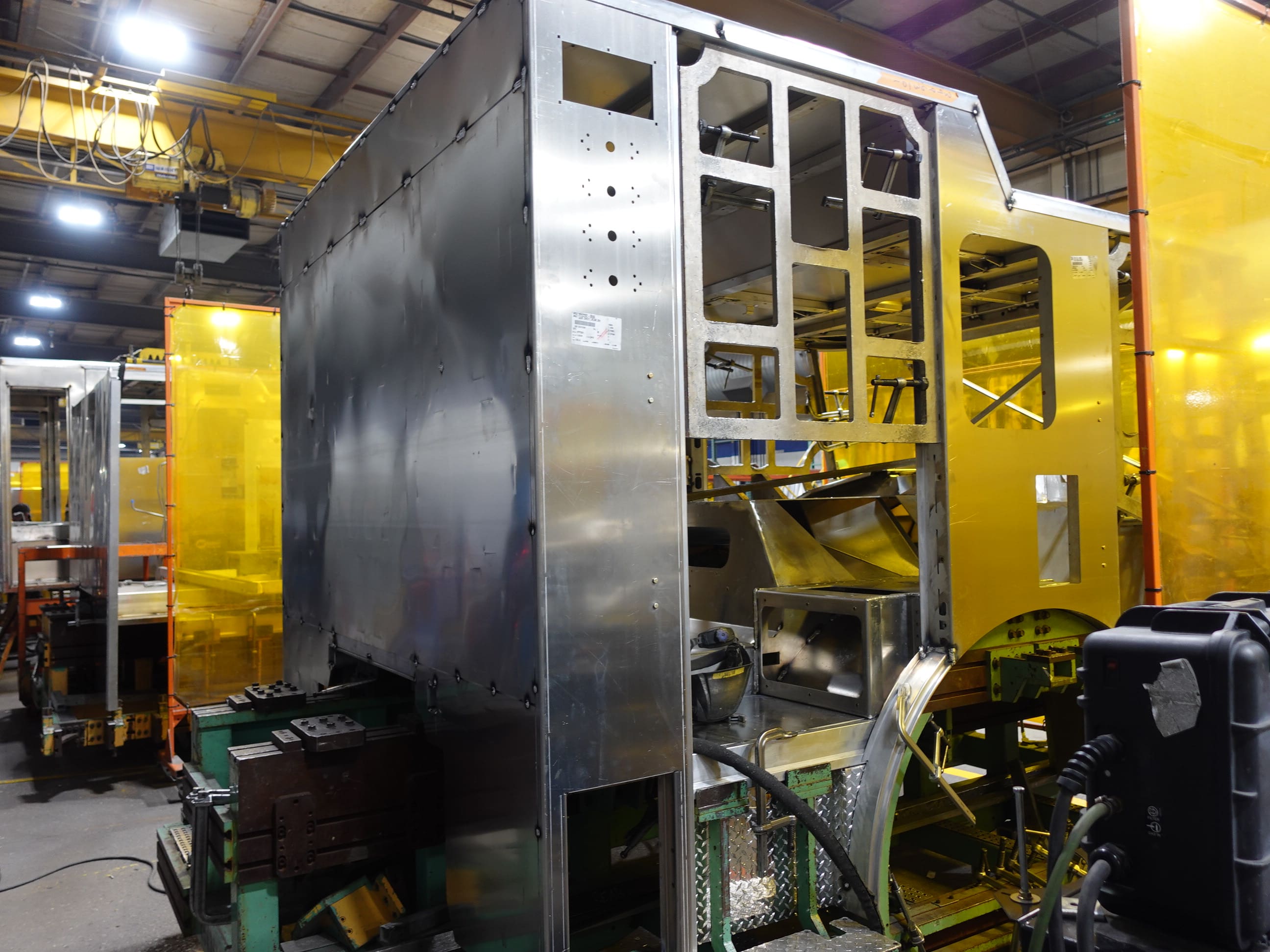

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
