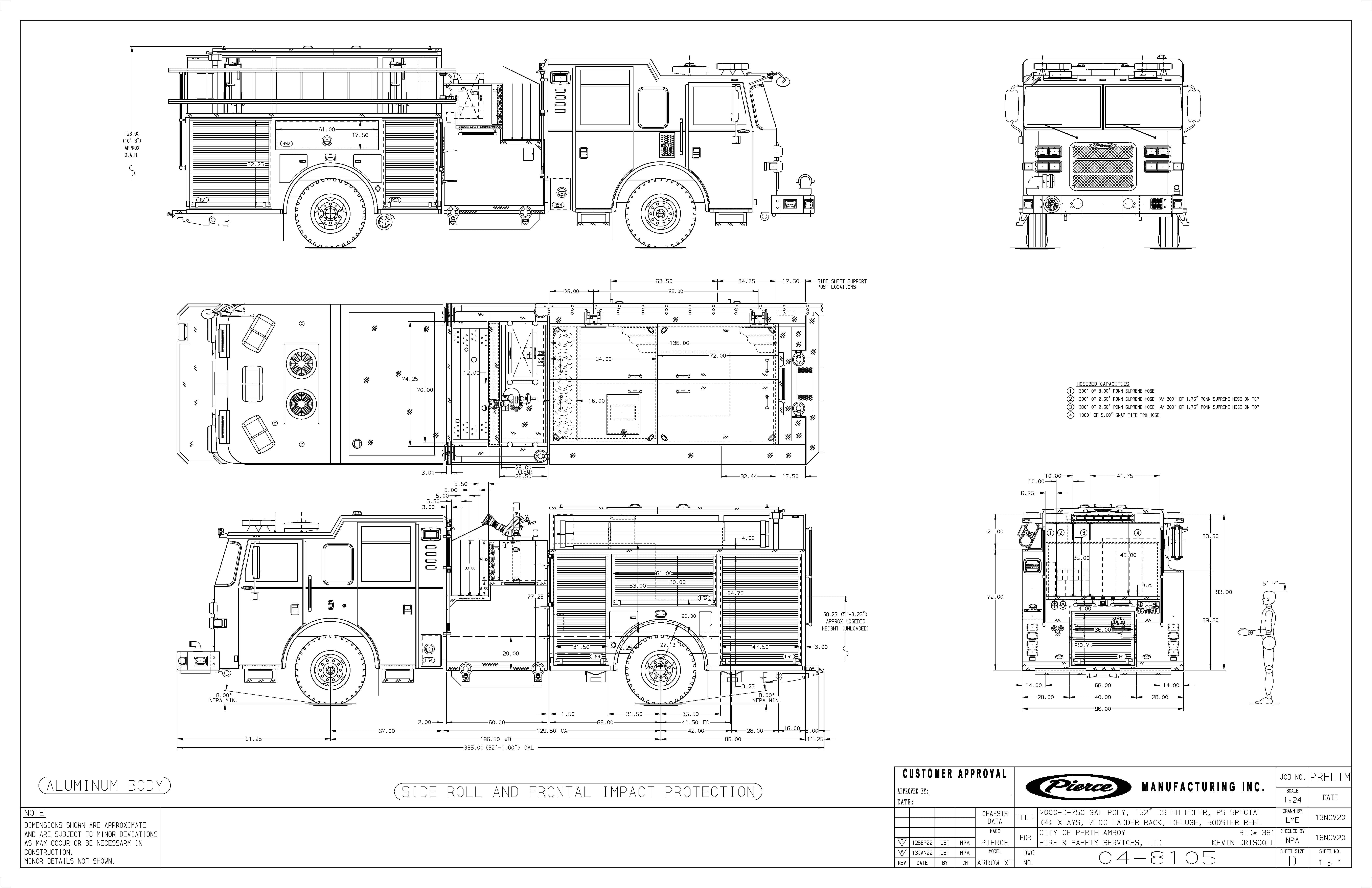

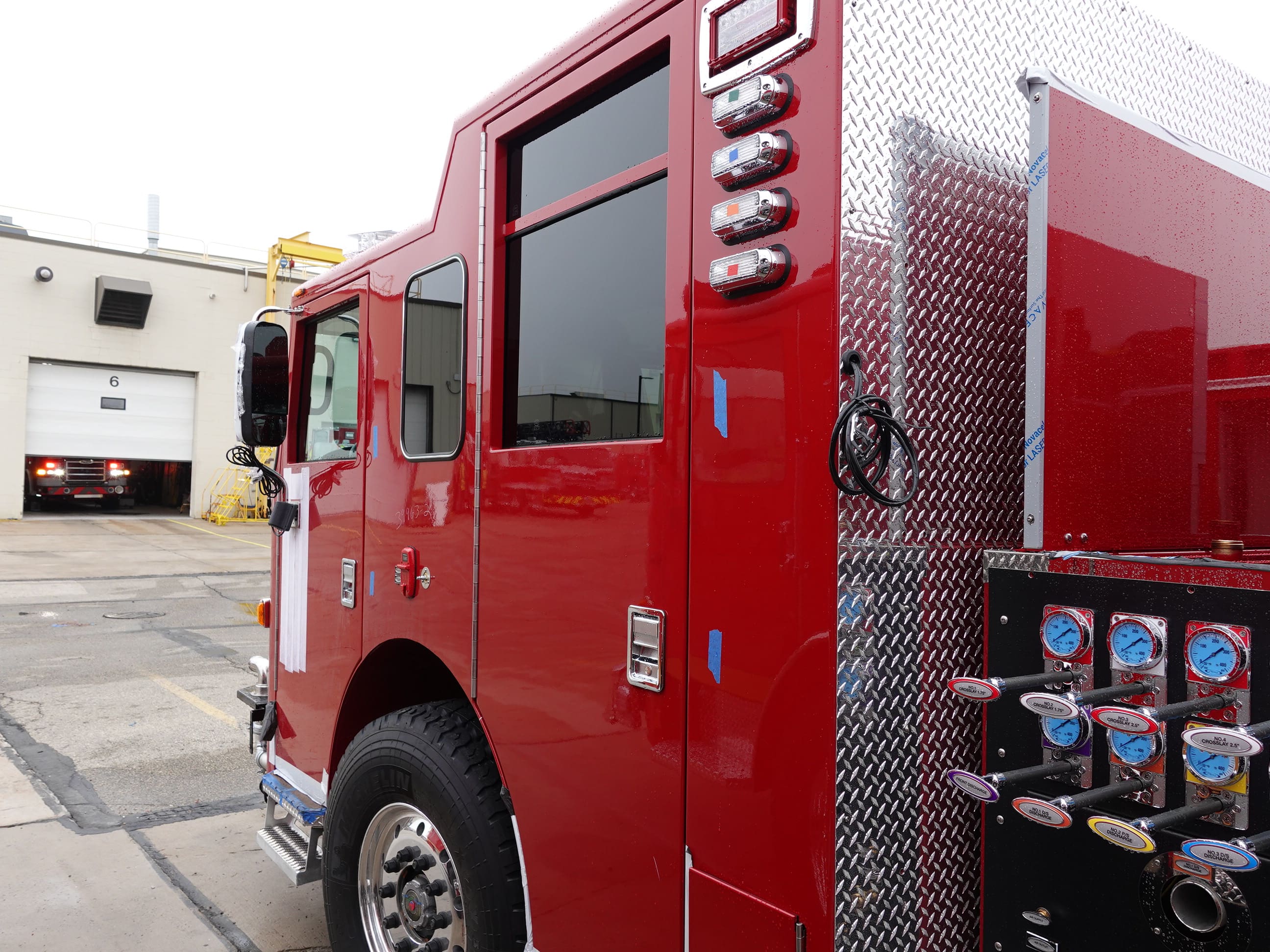

05-15-26

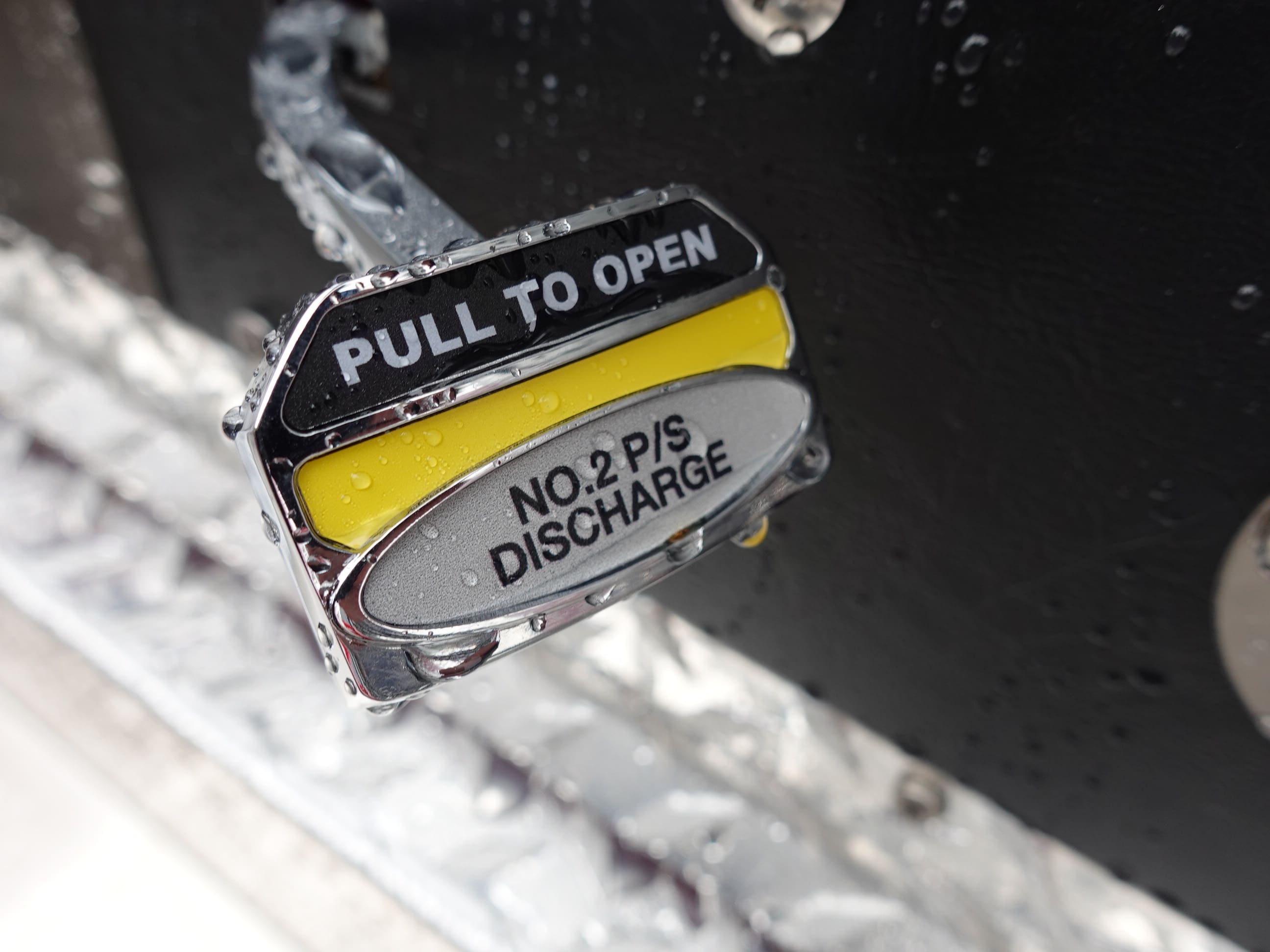

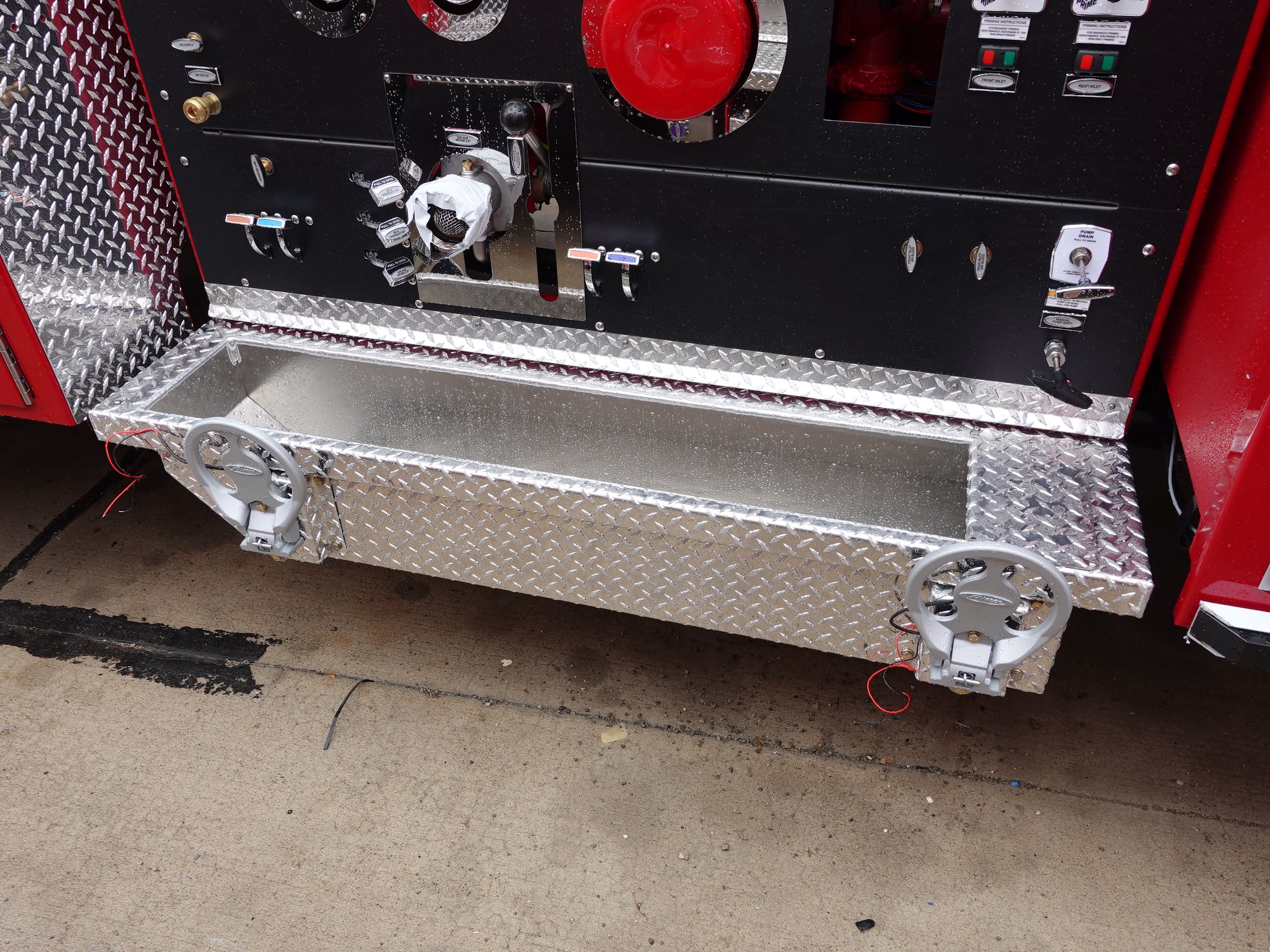

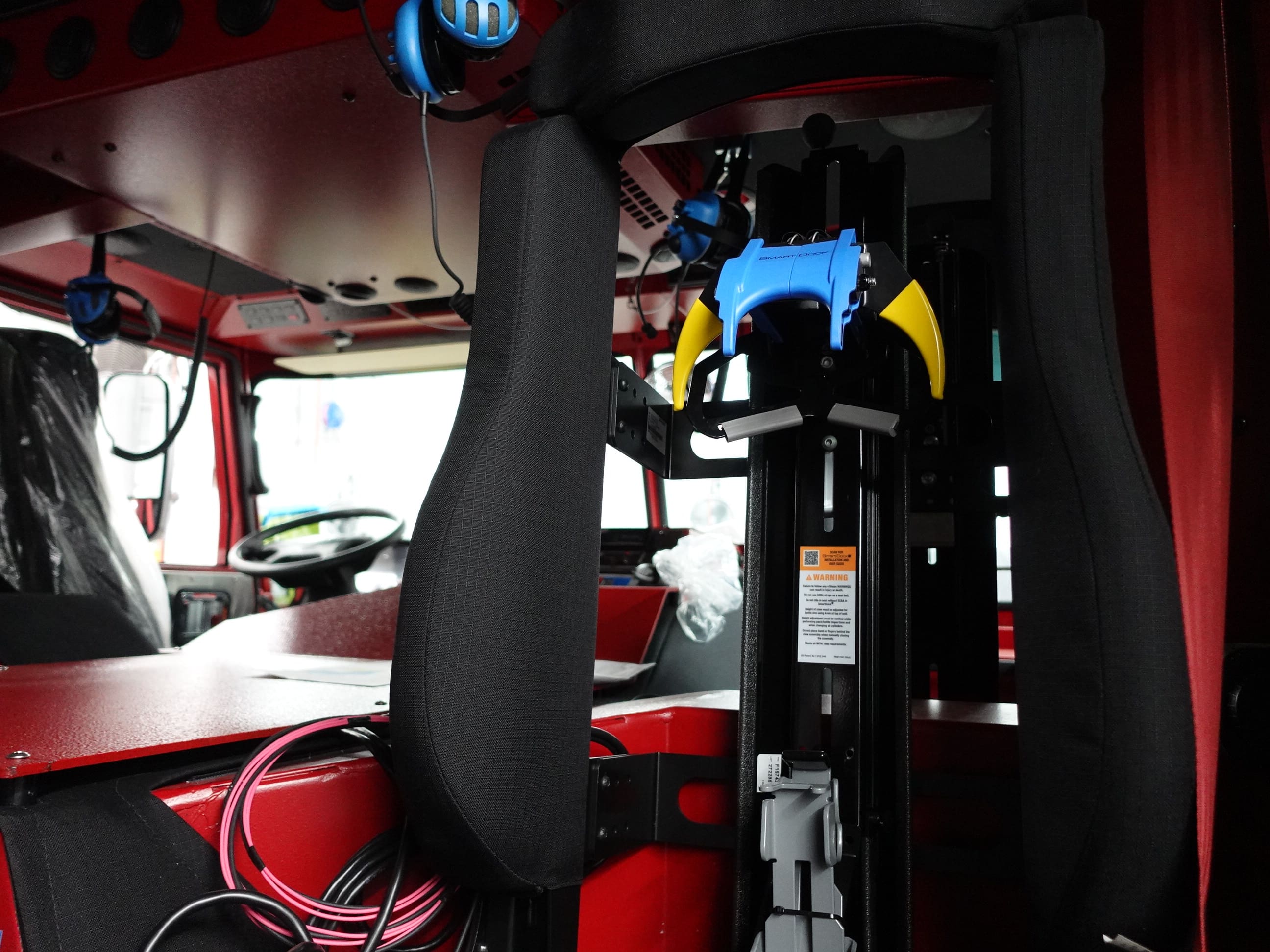

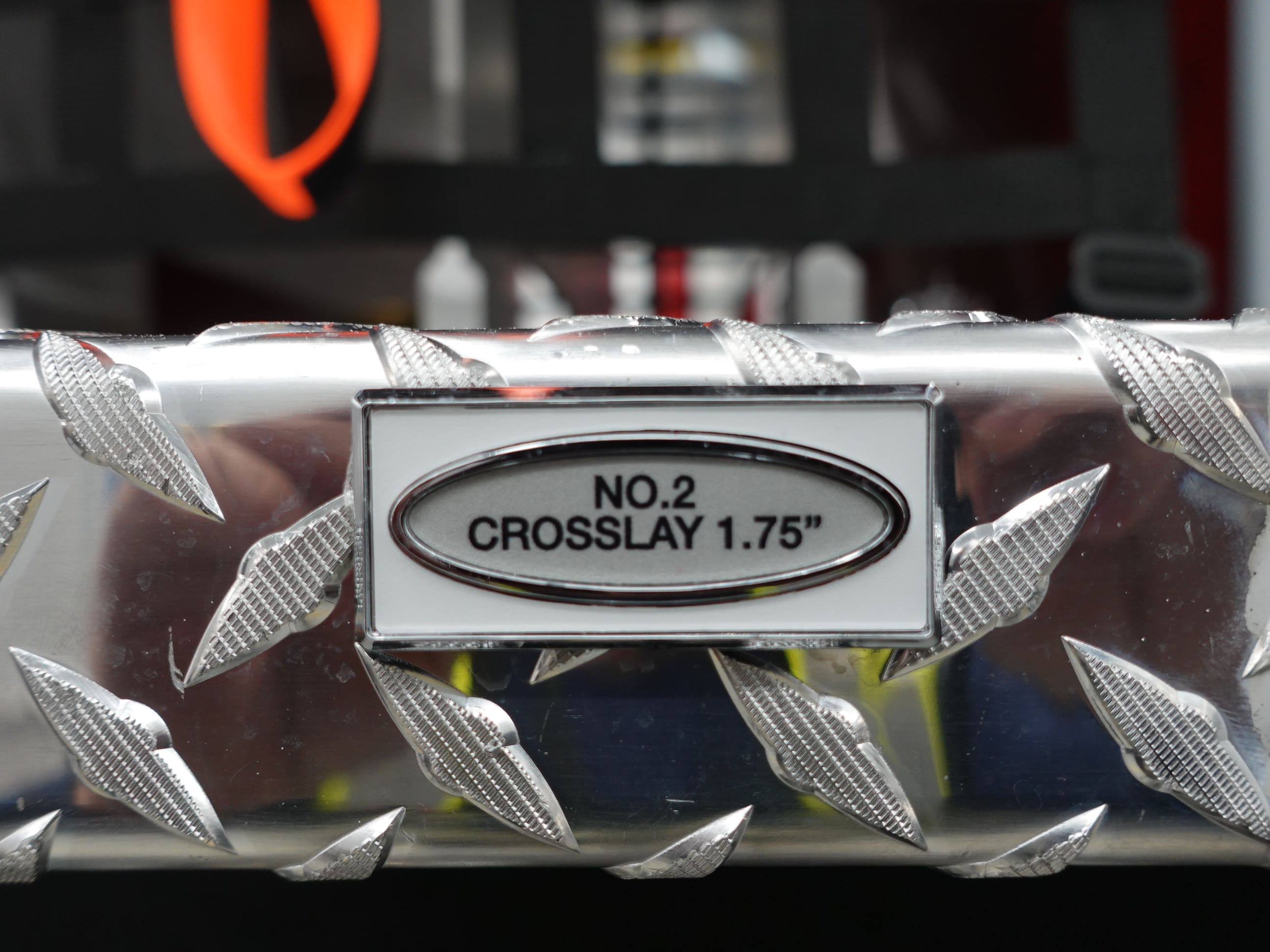

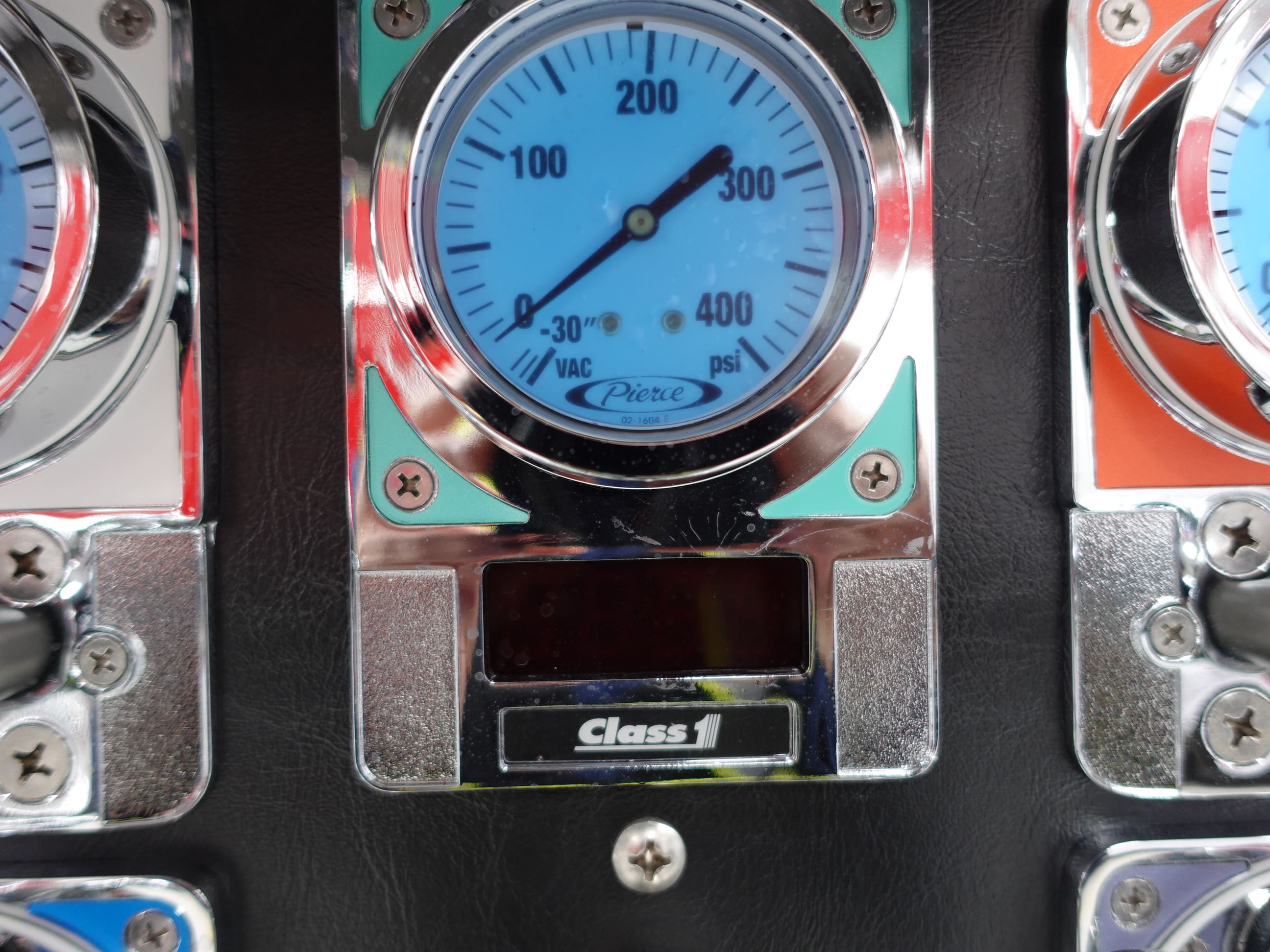

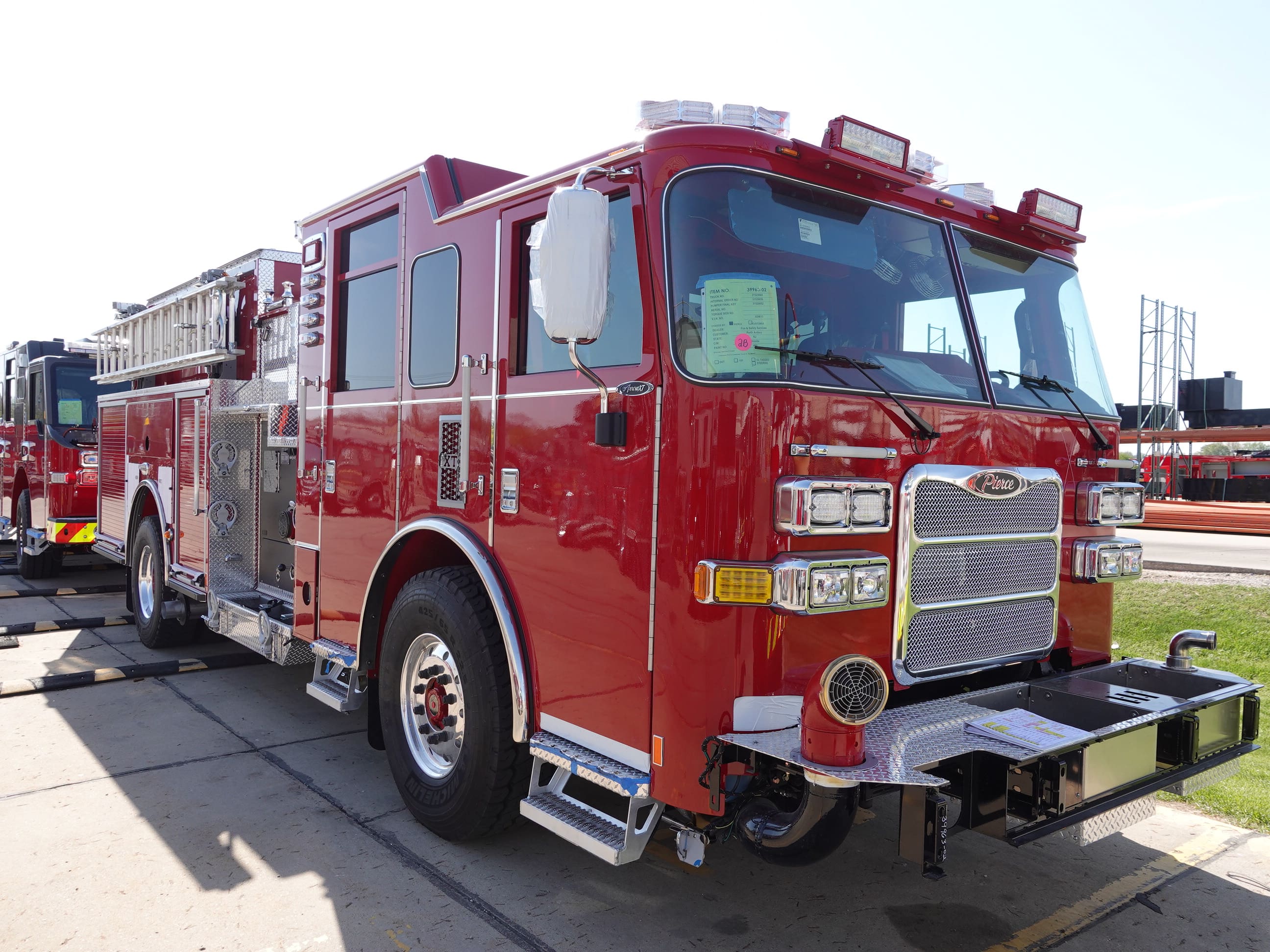

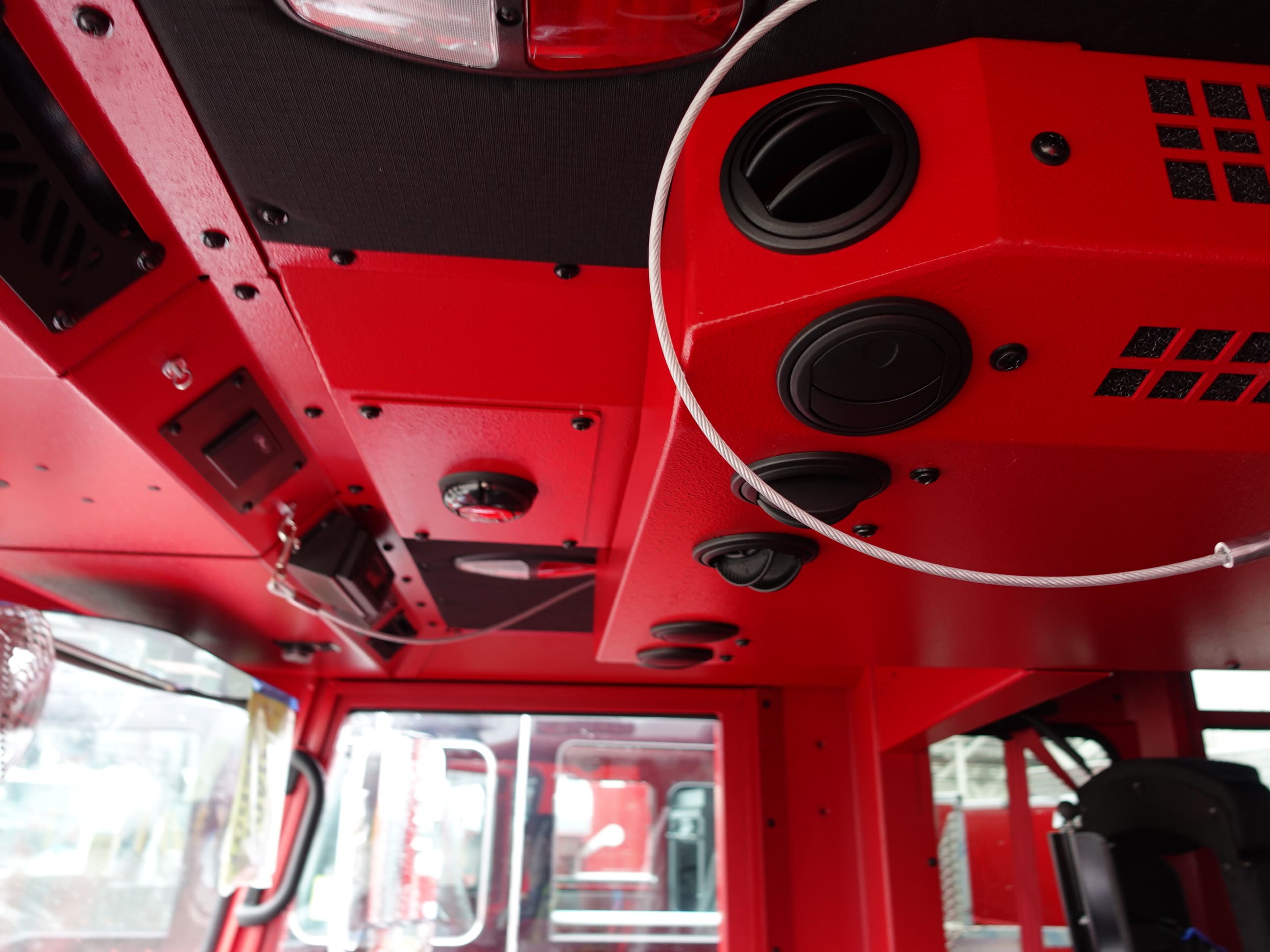

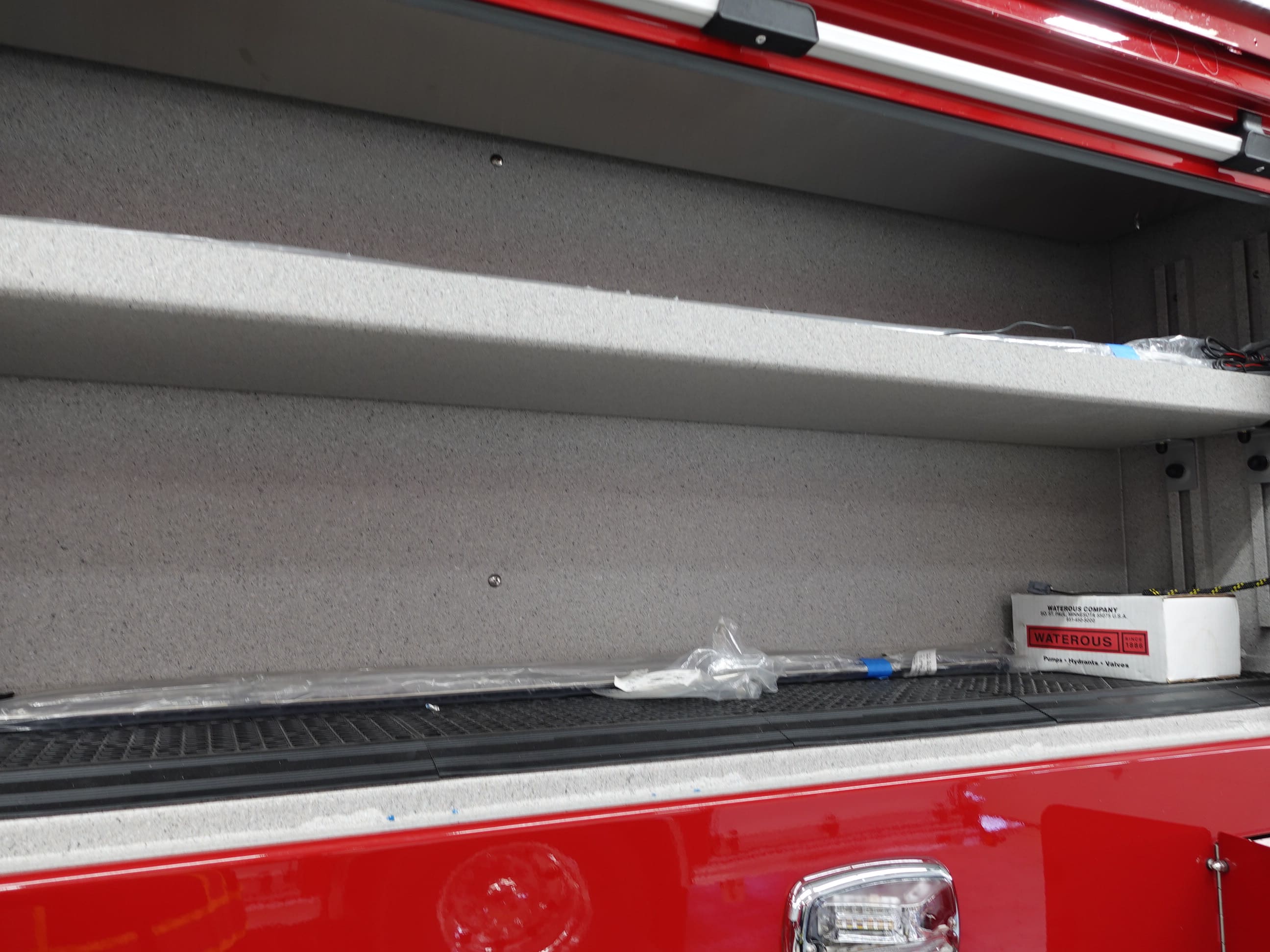

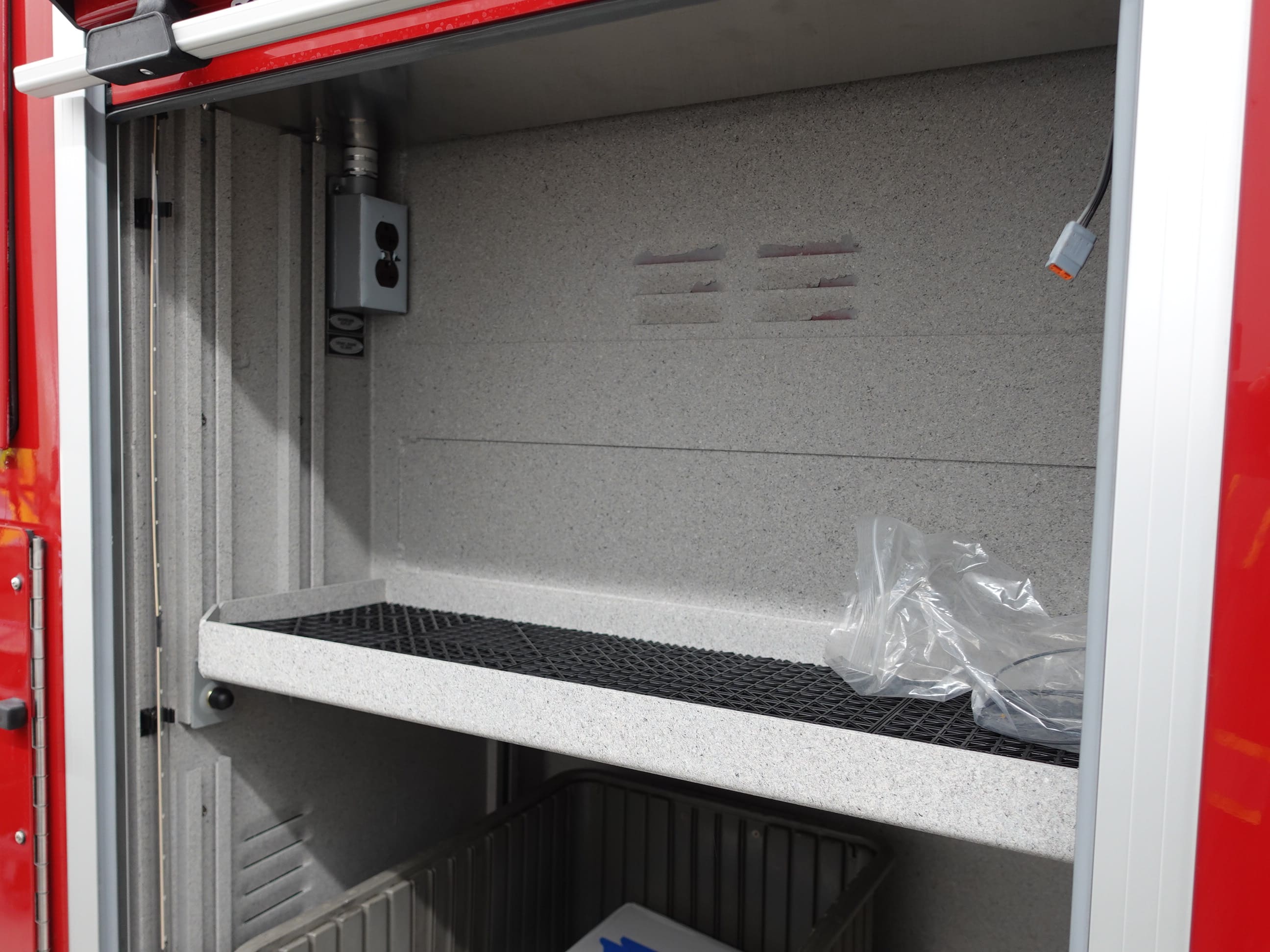

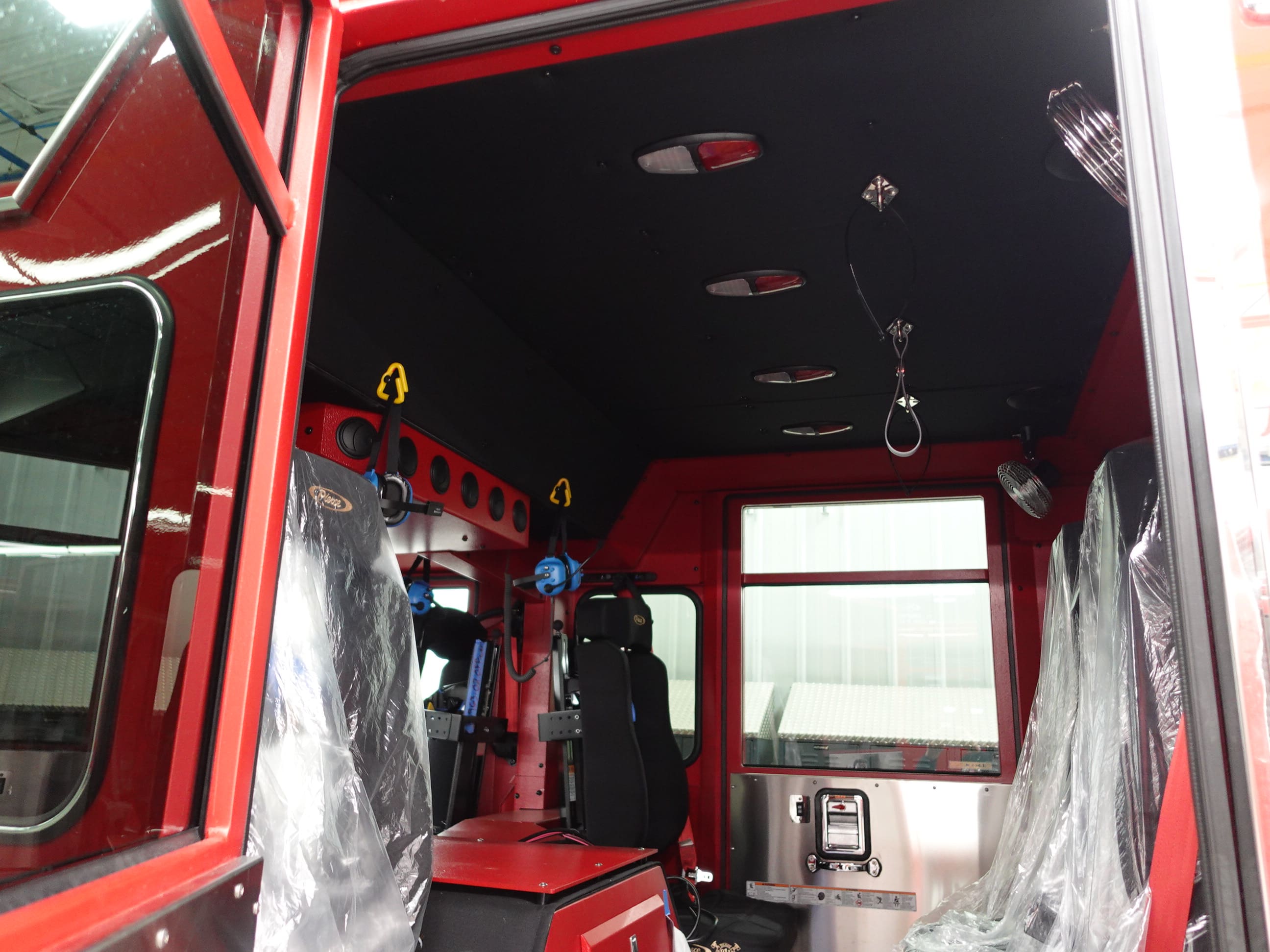

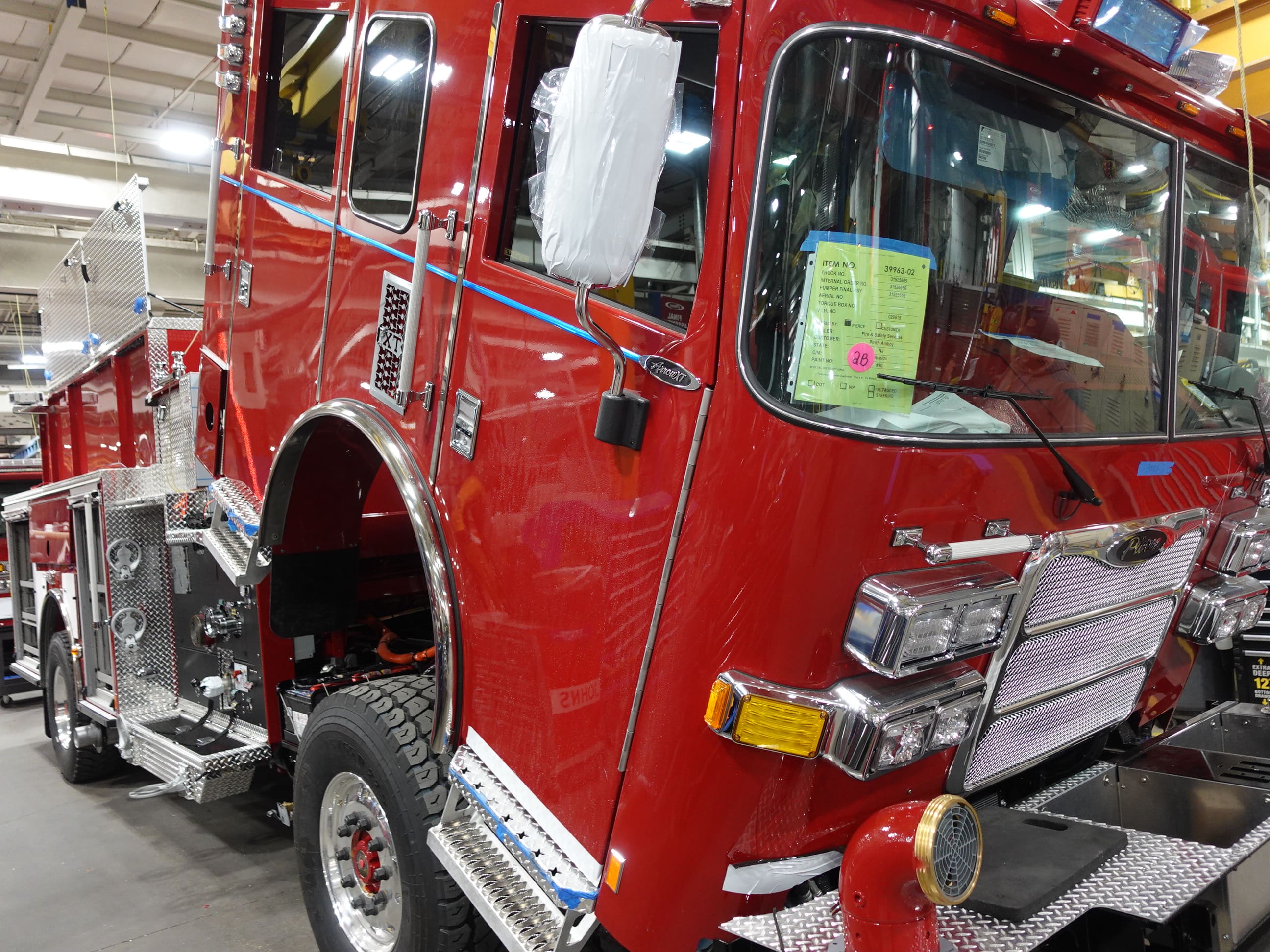

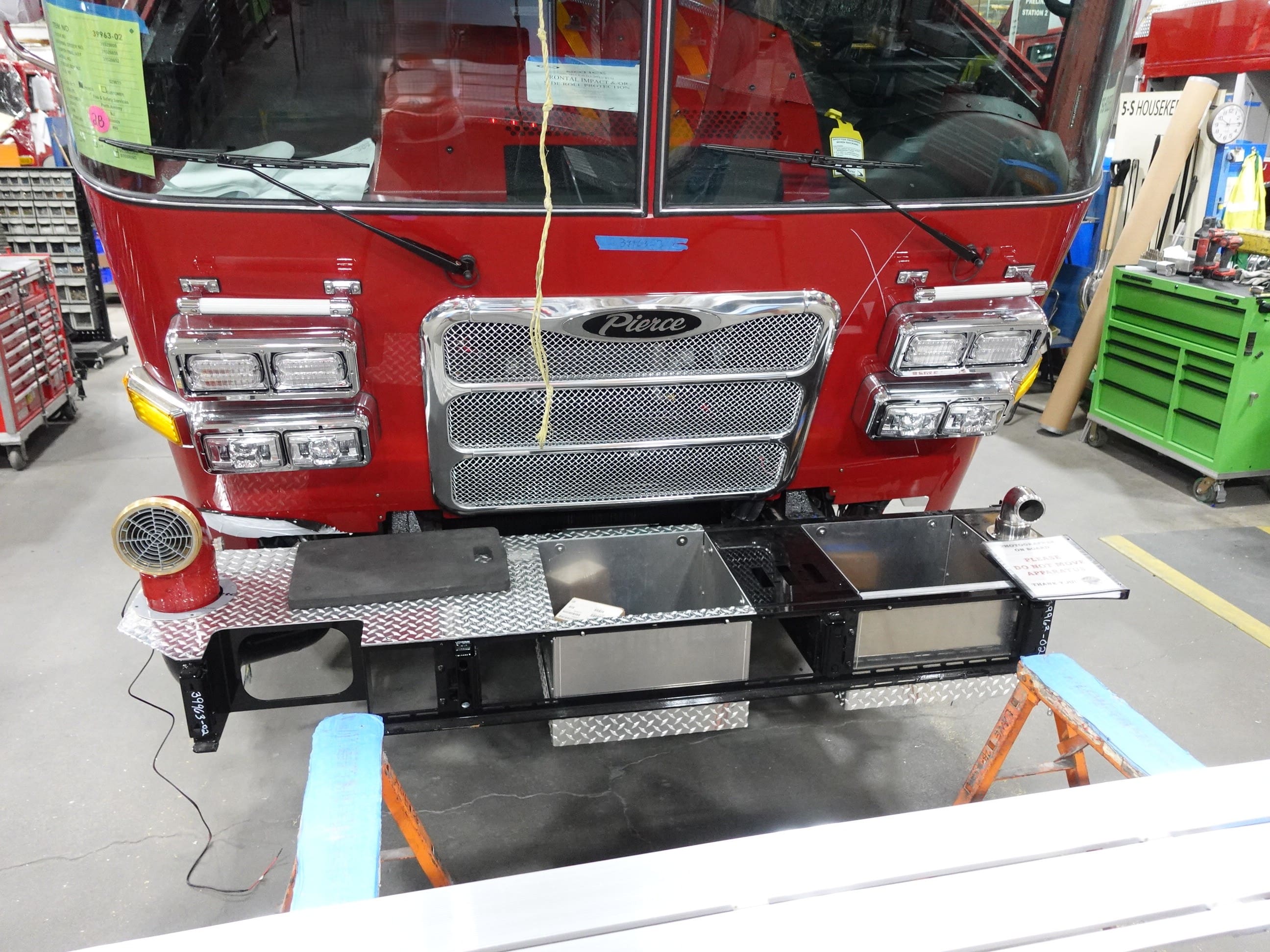

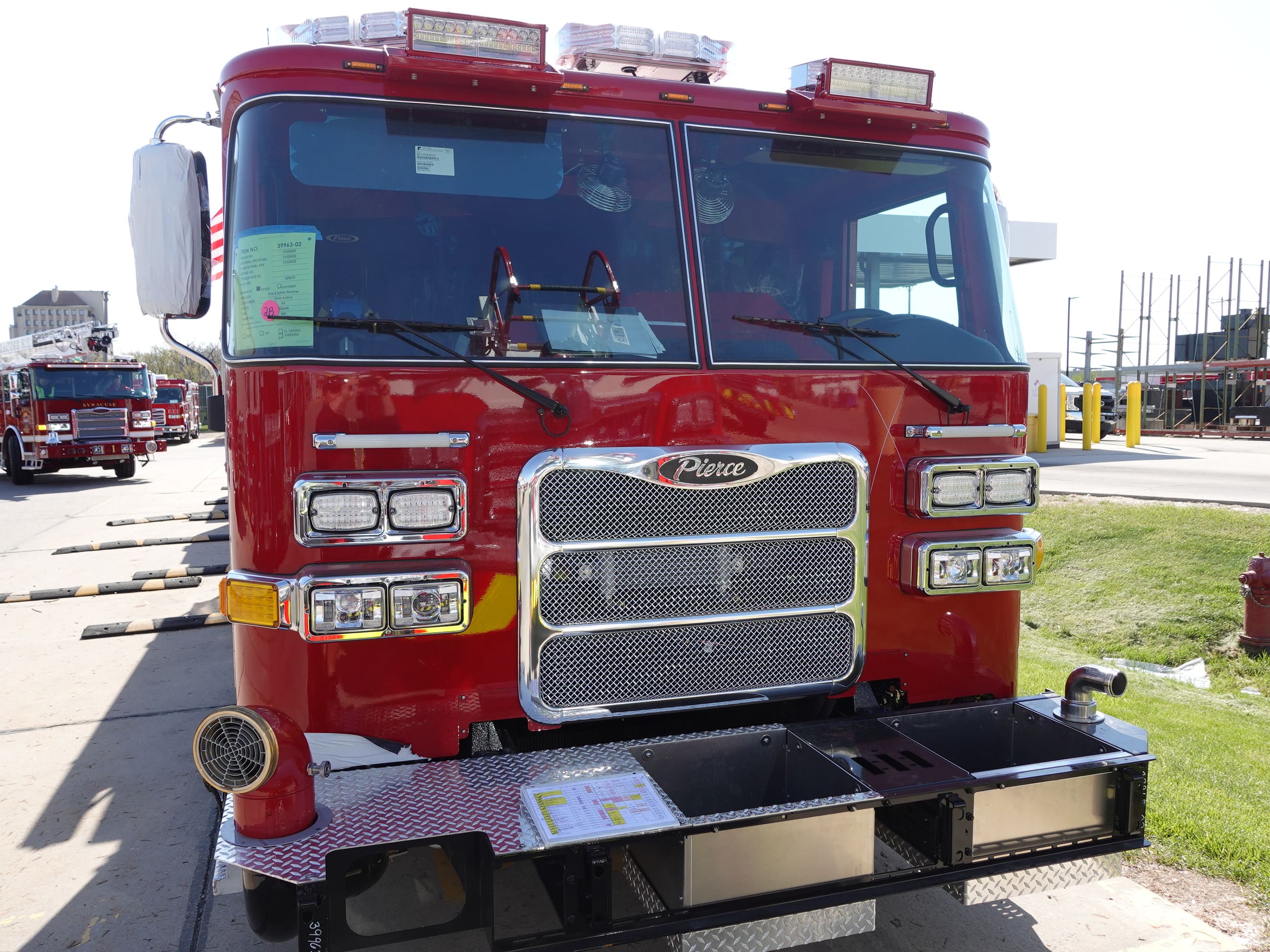

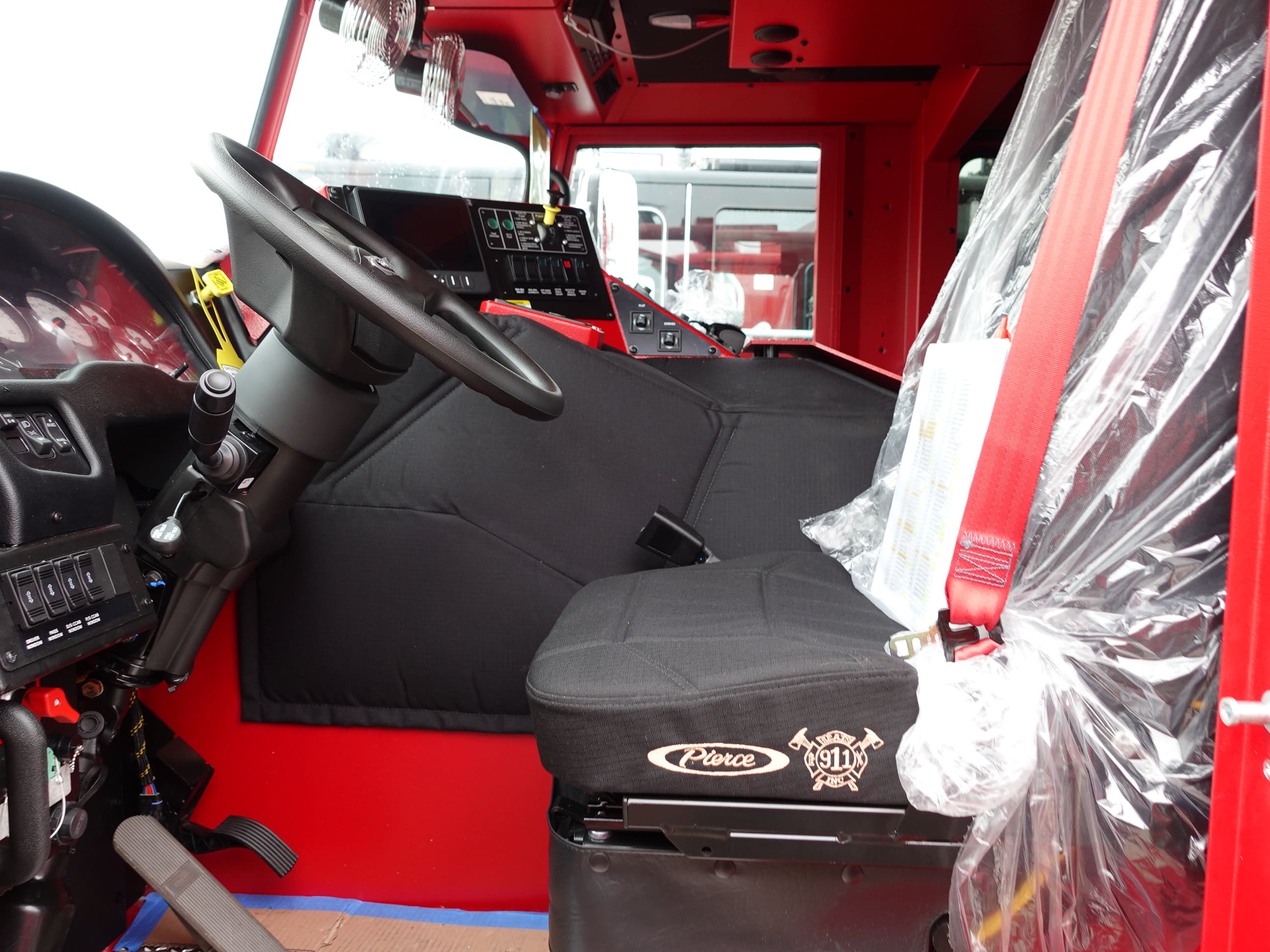

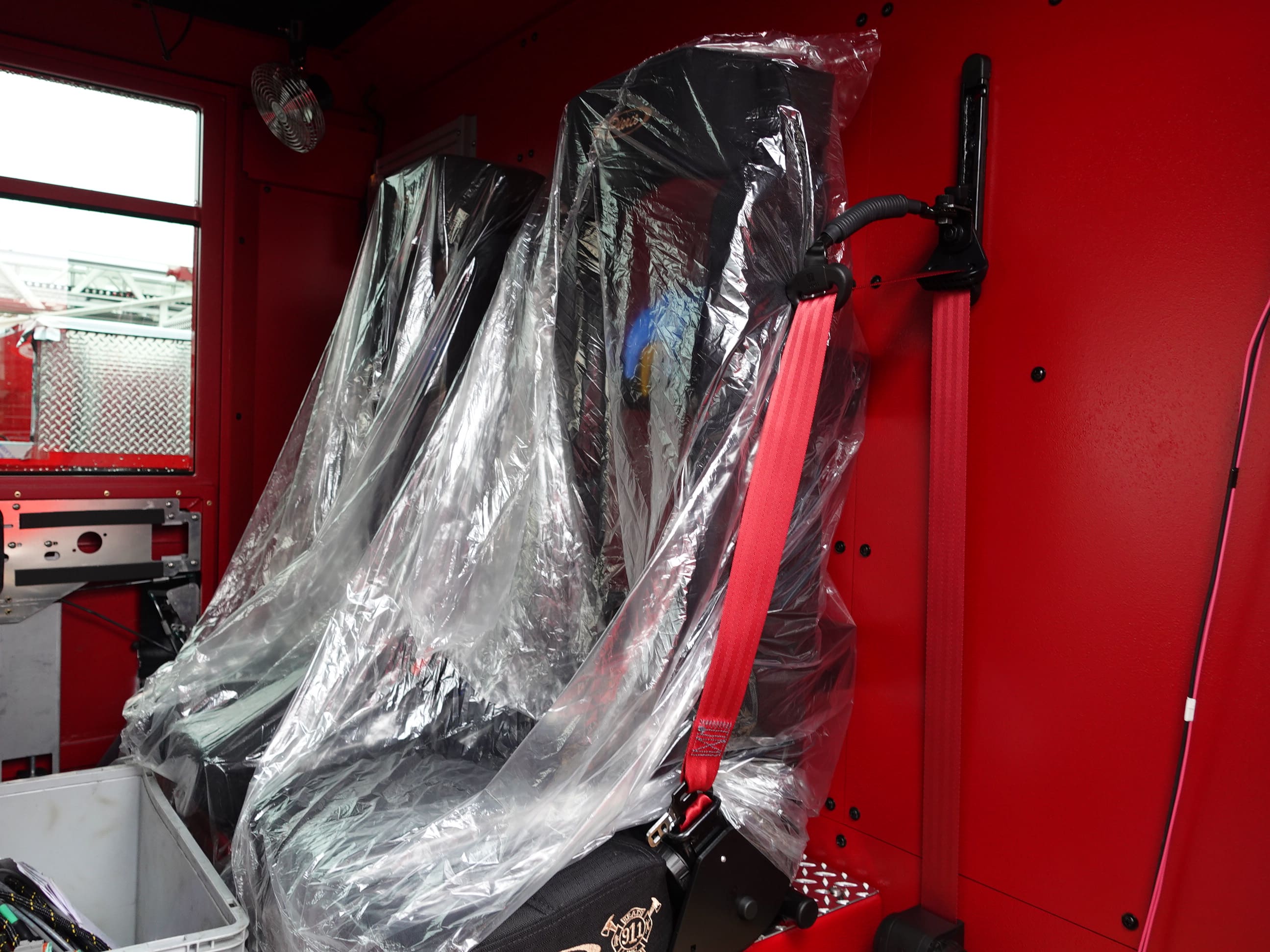

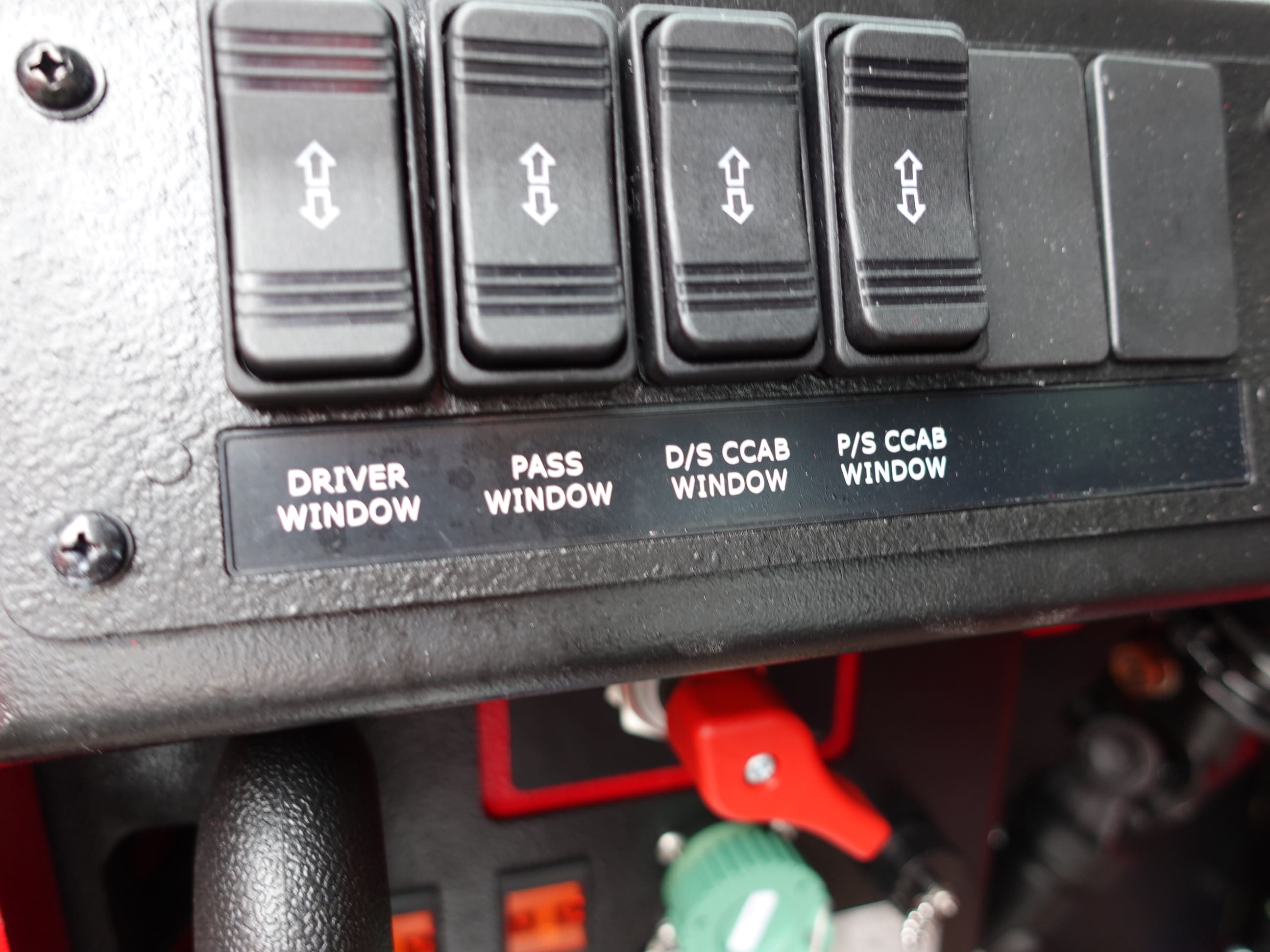

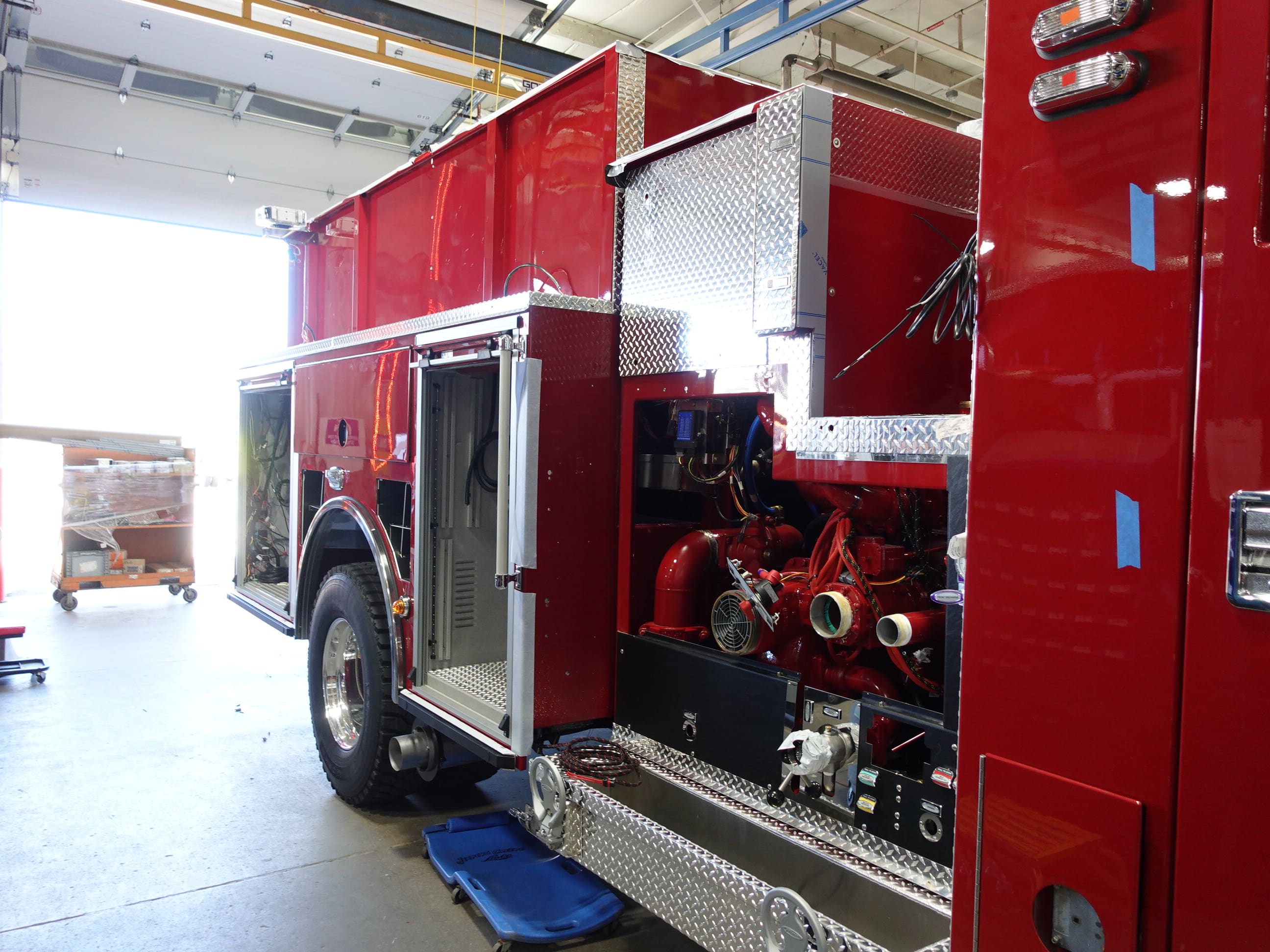

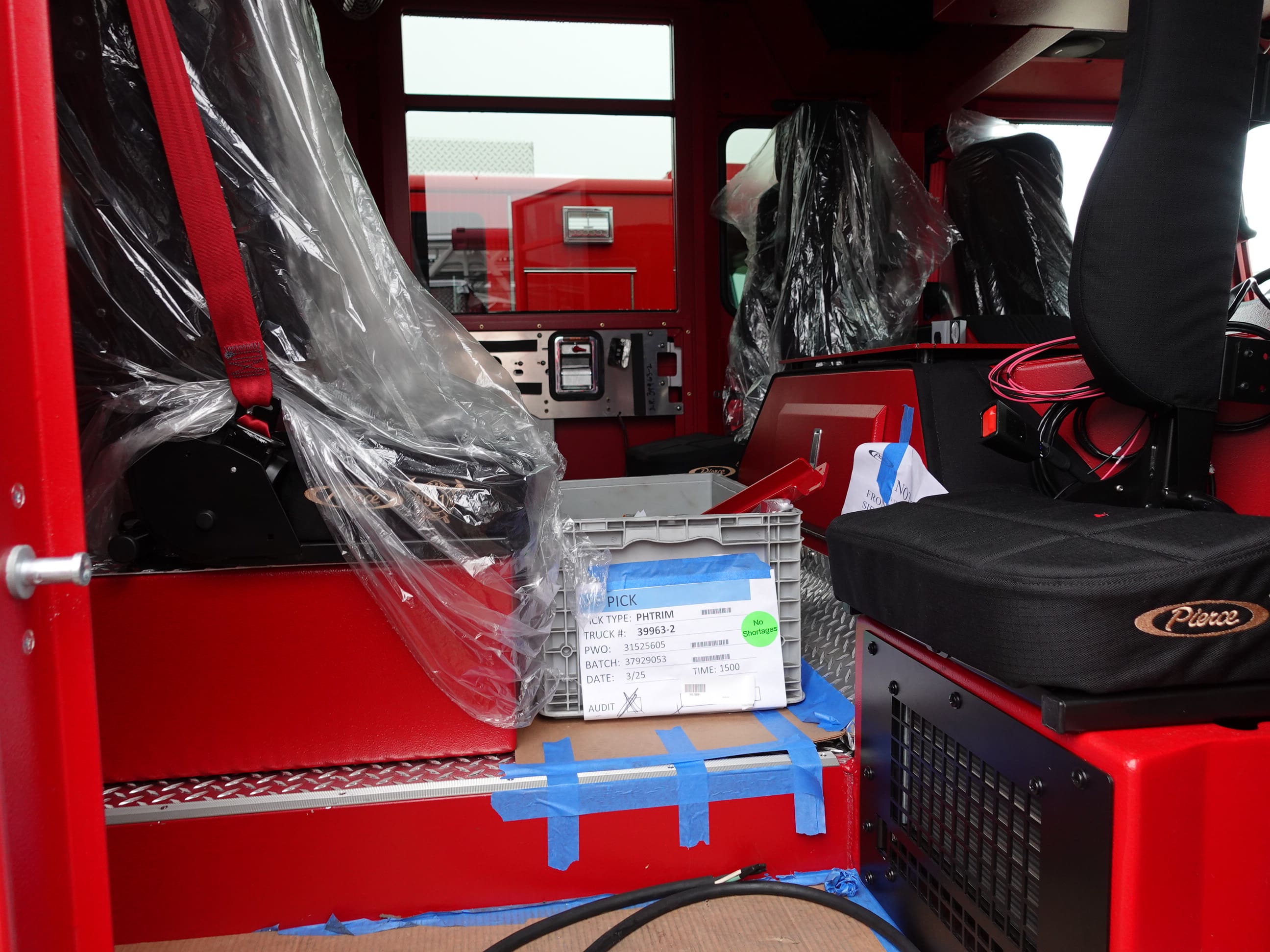

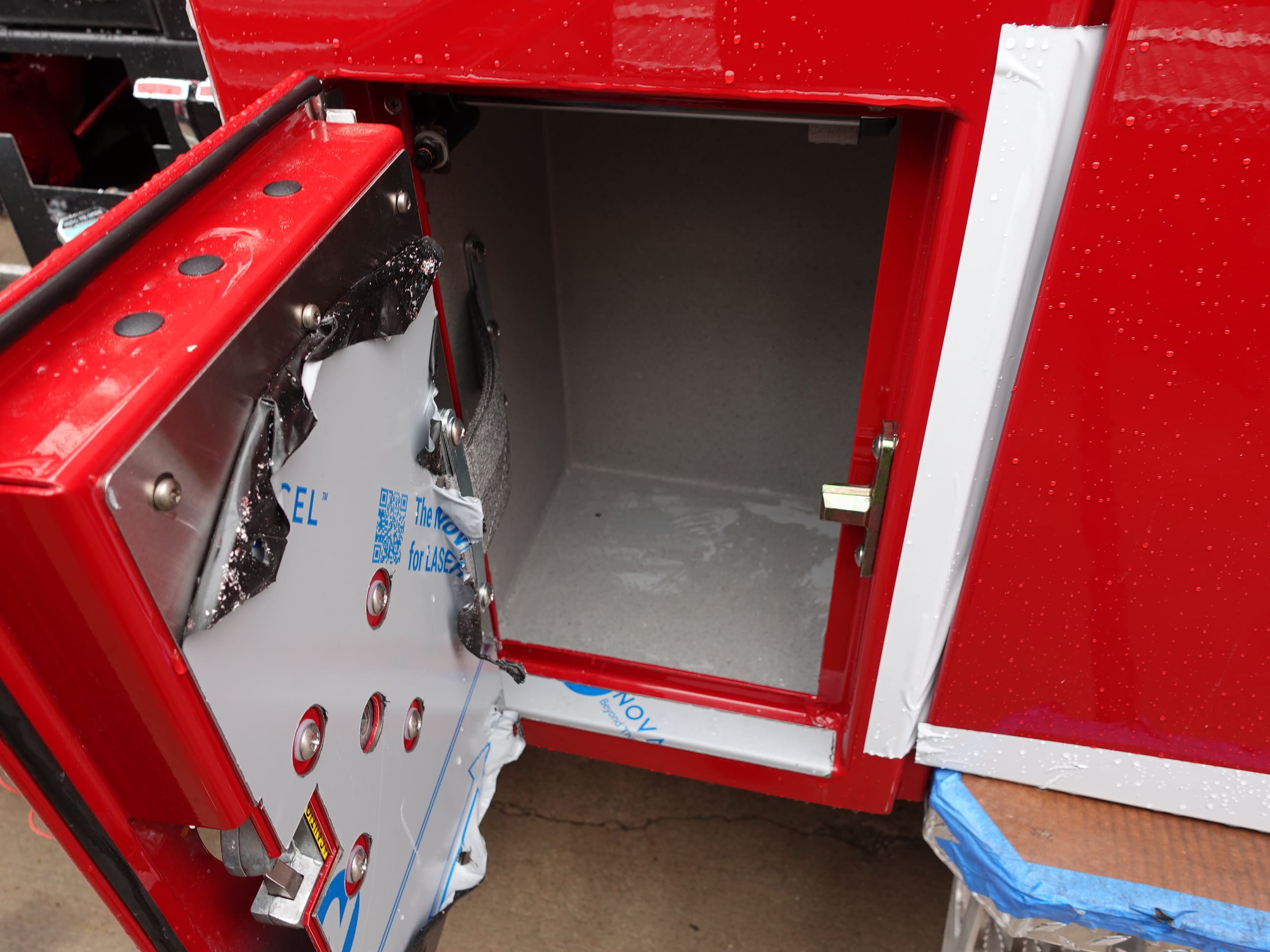

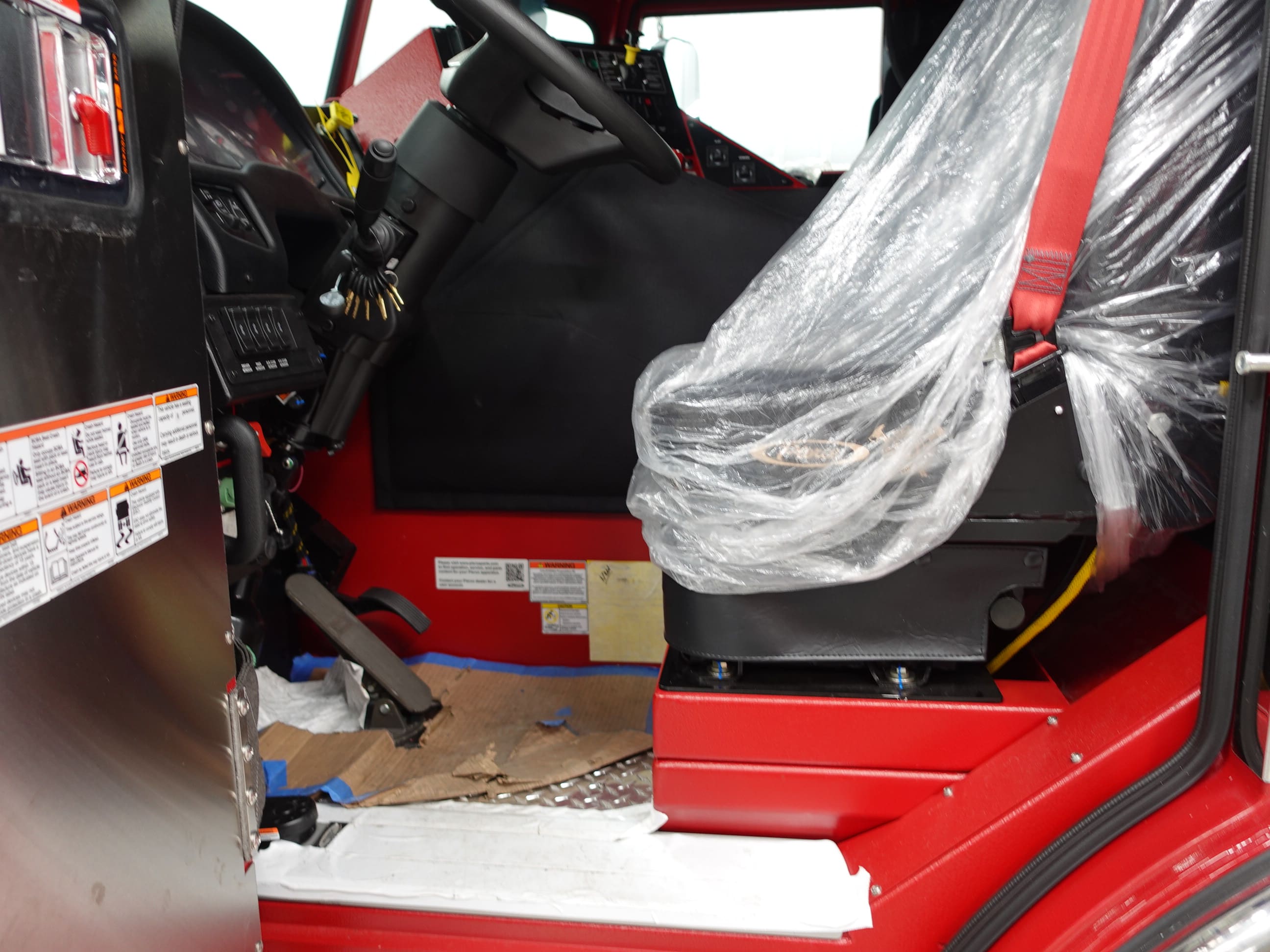

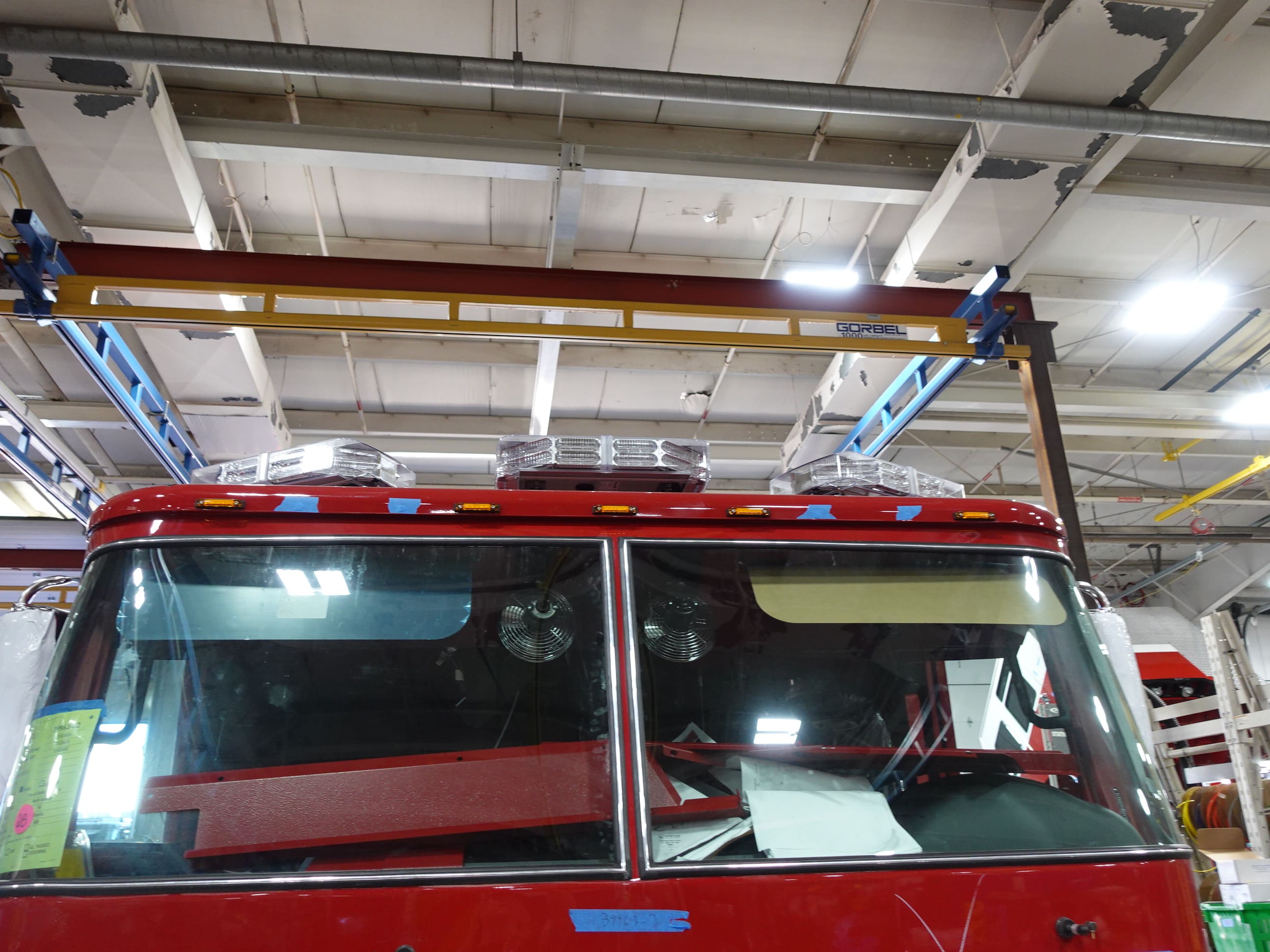

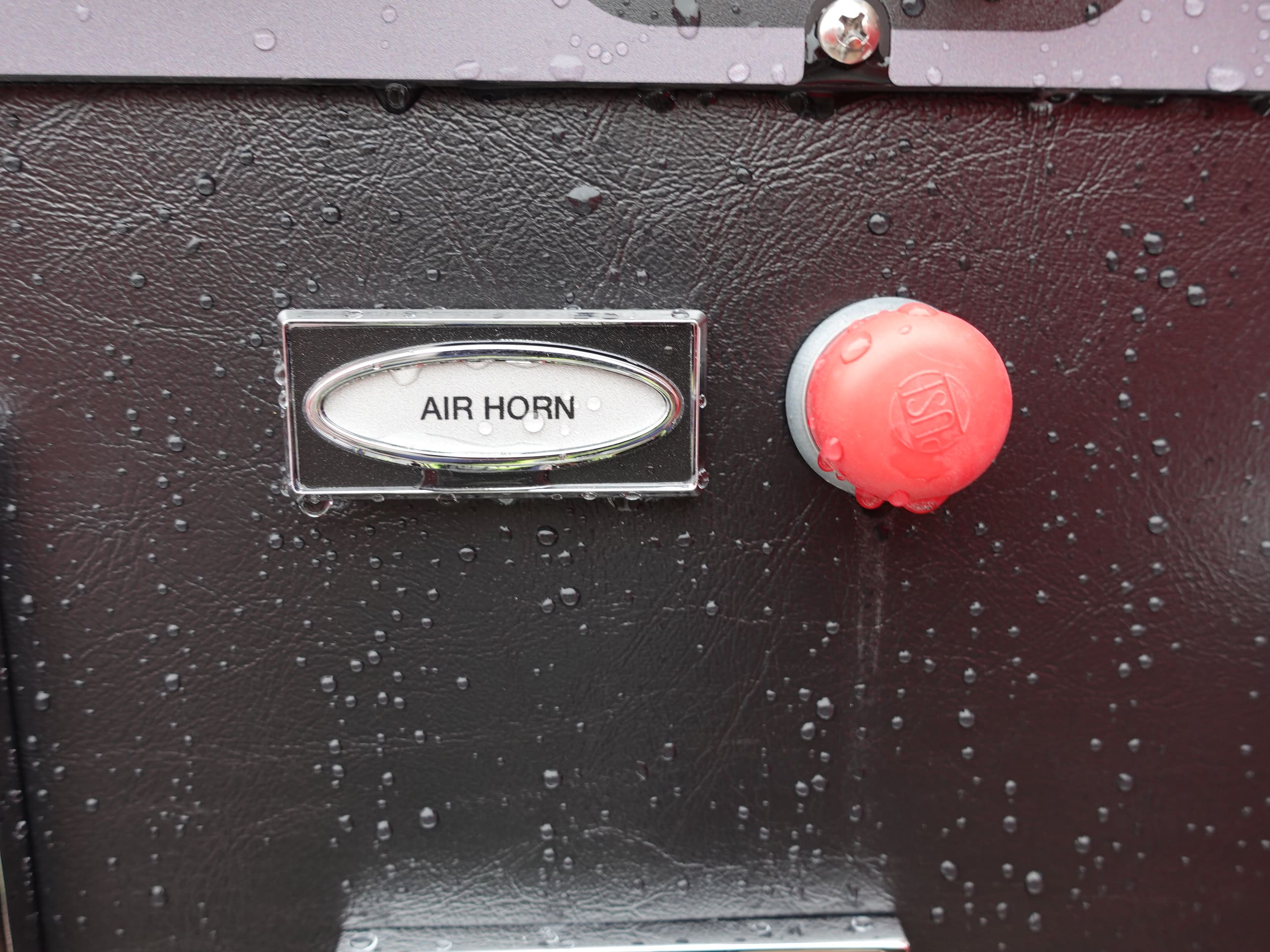

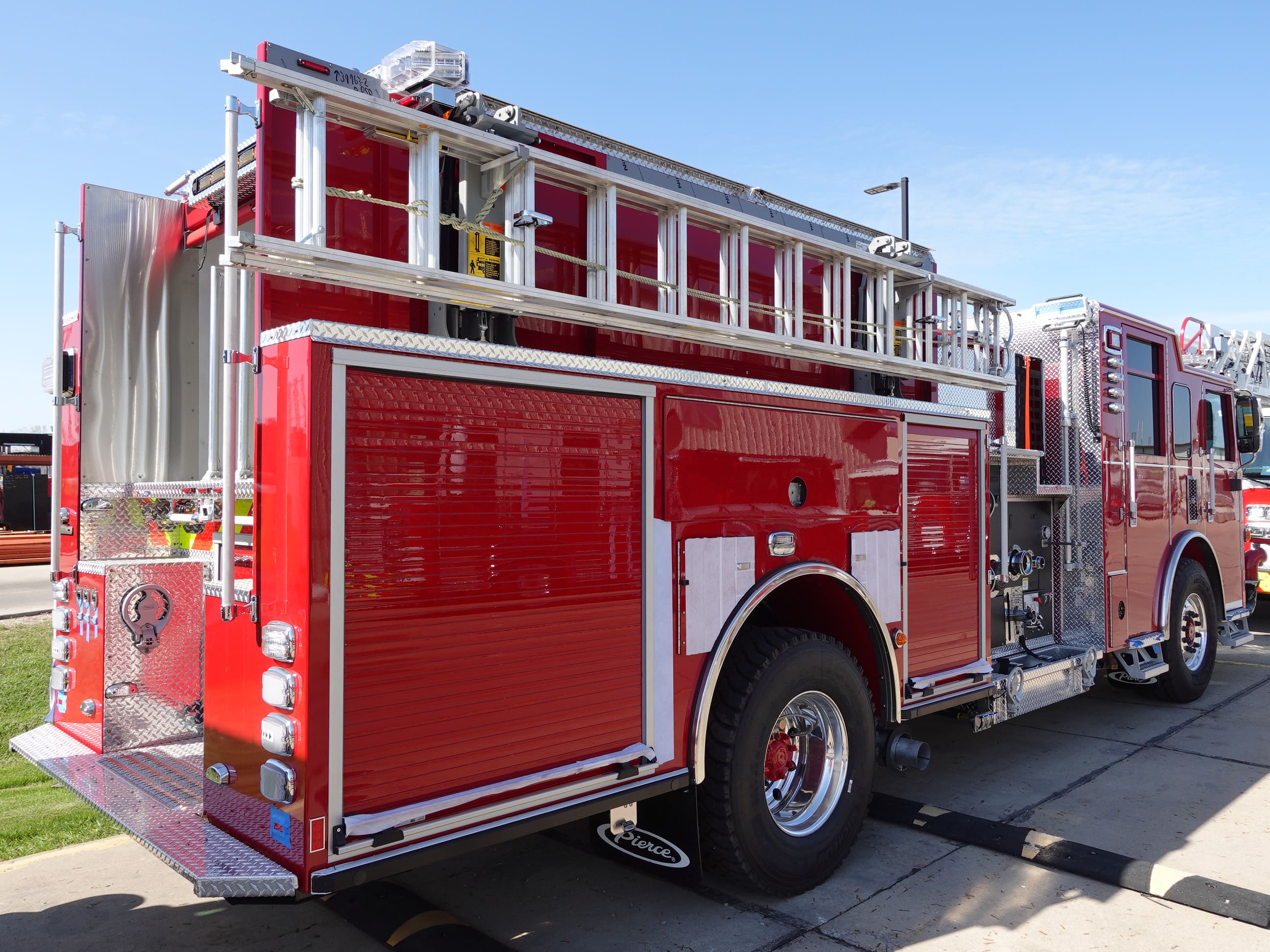

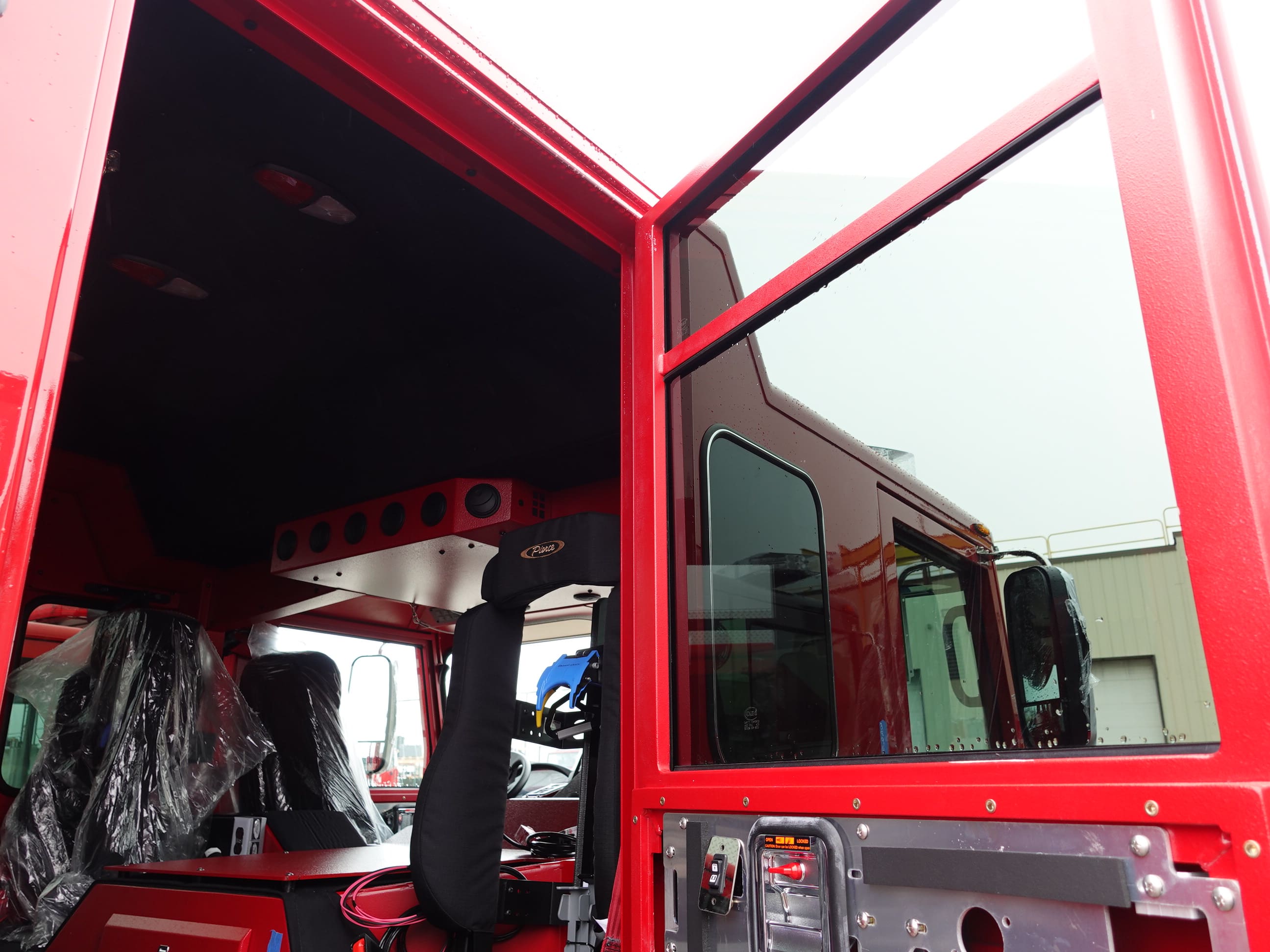

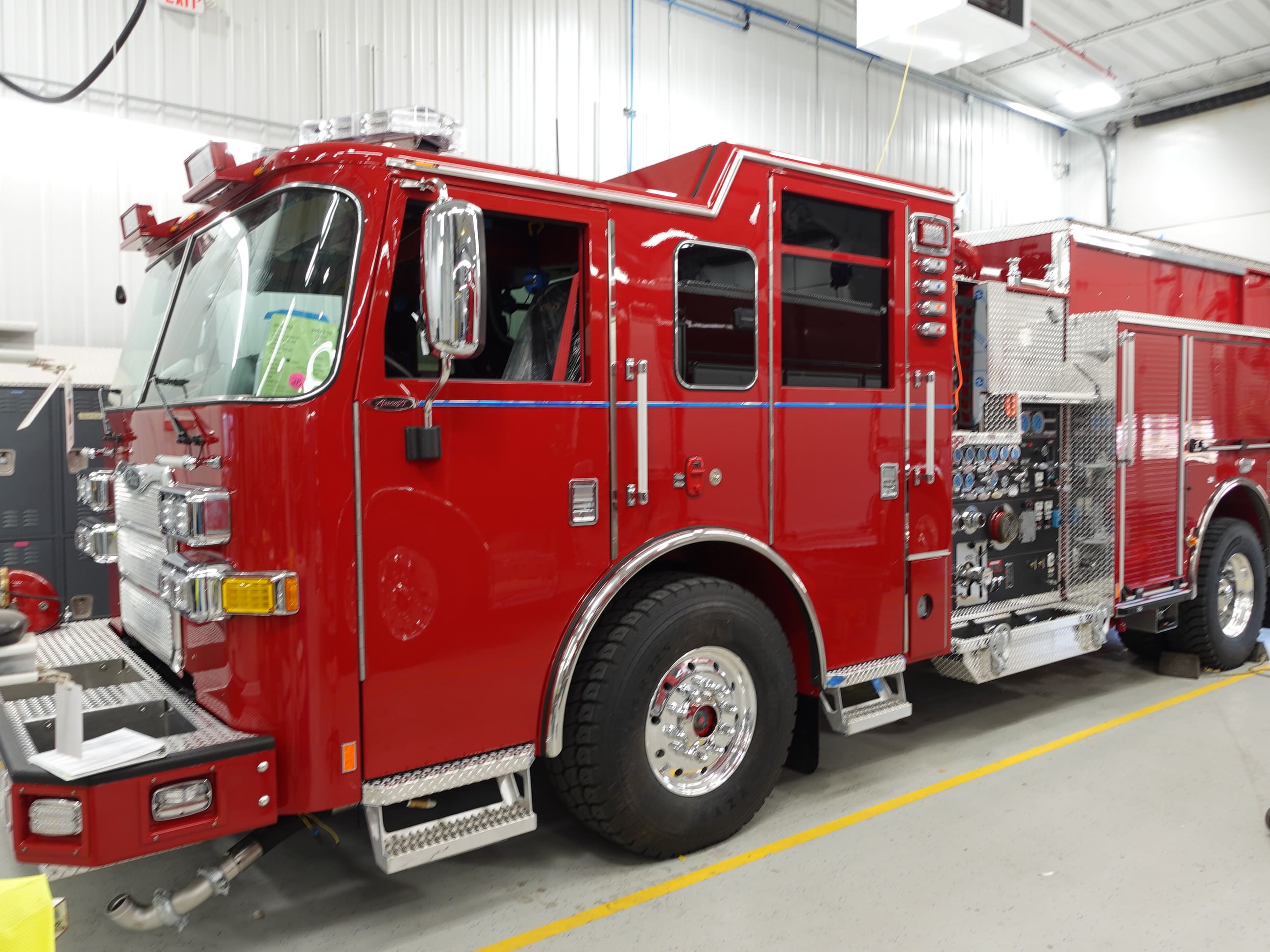

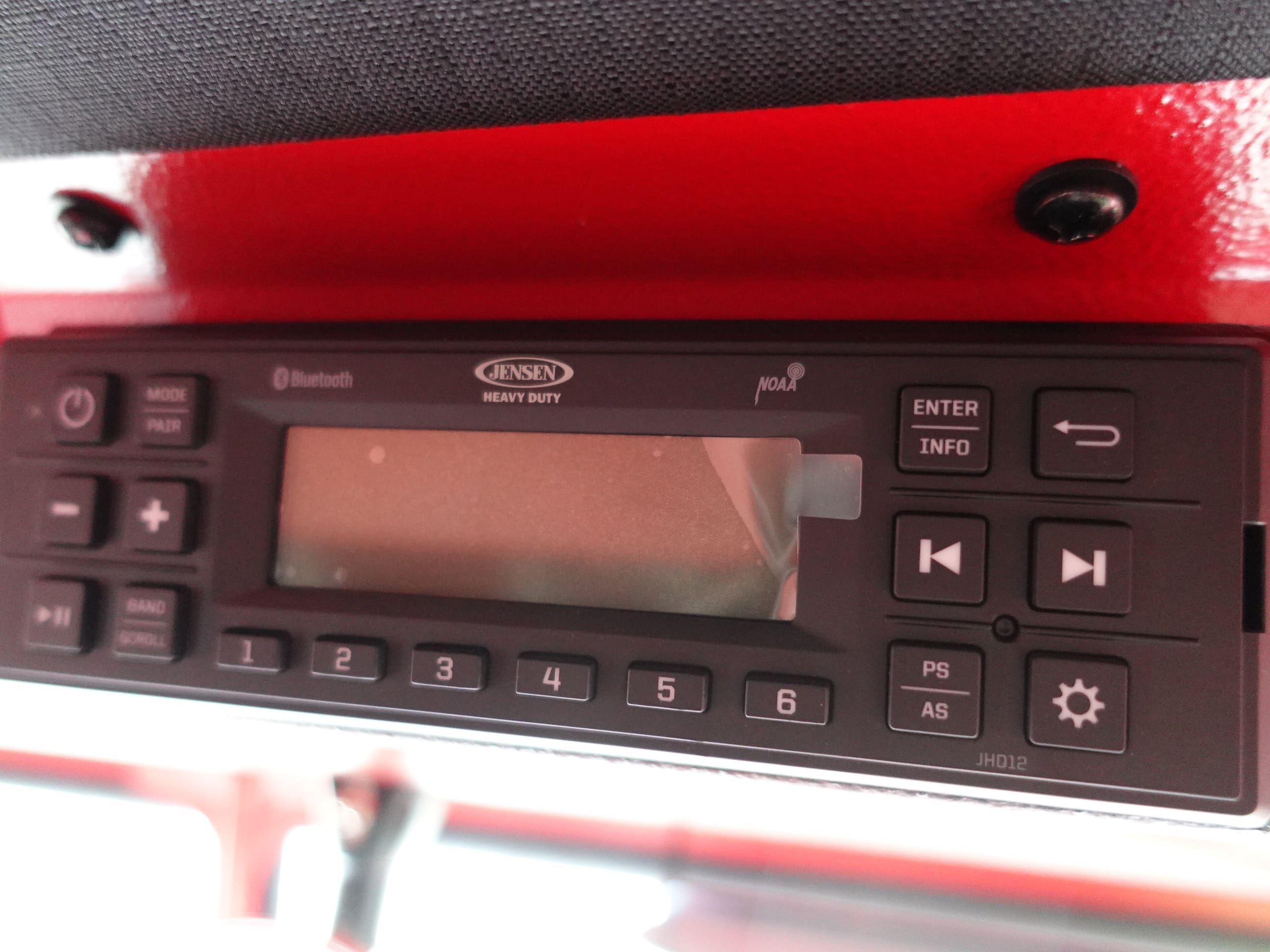

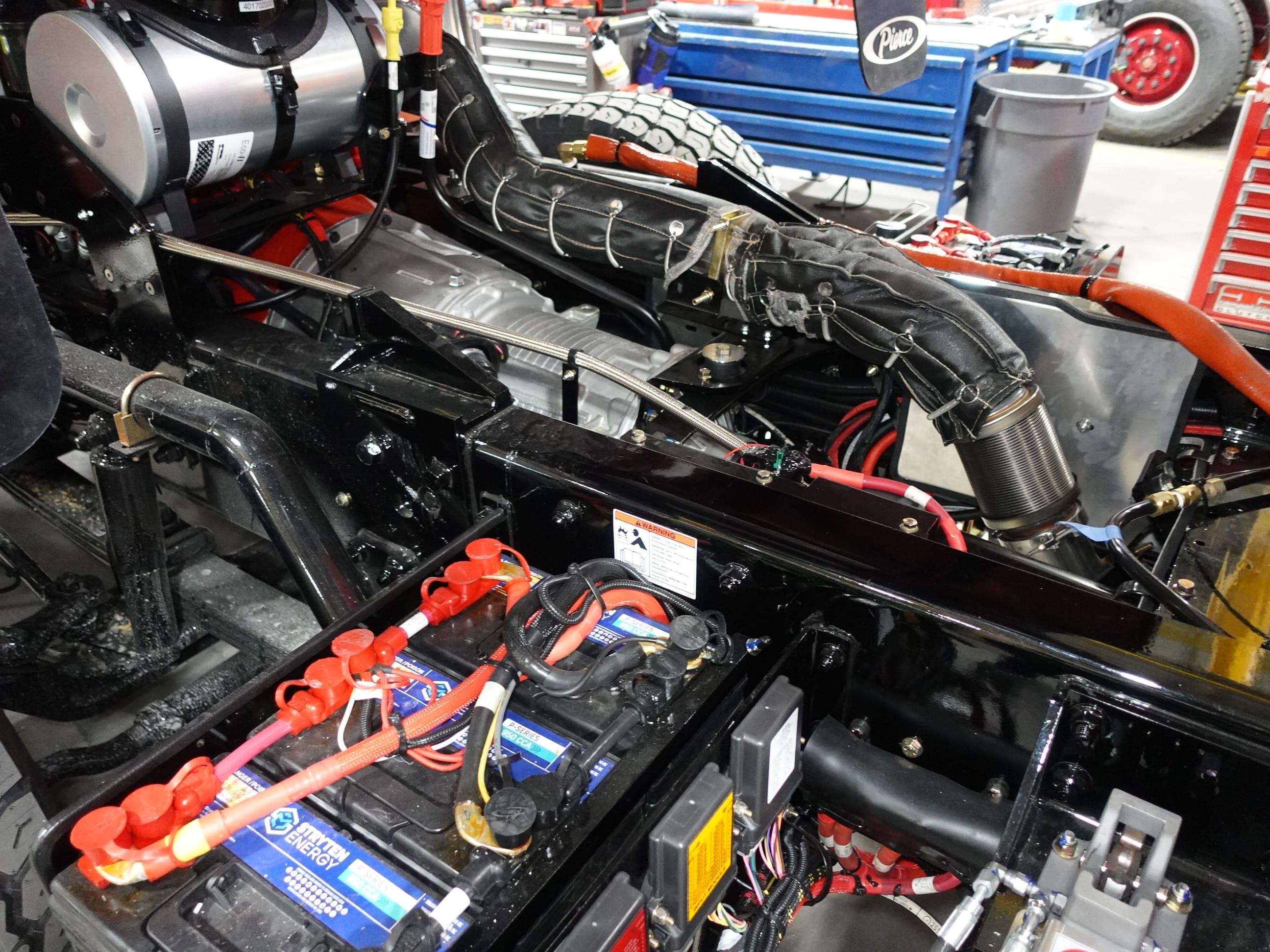

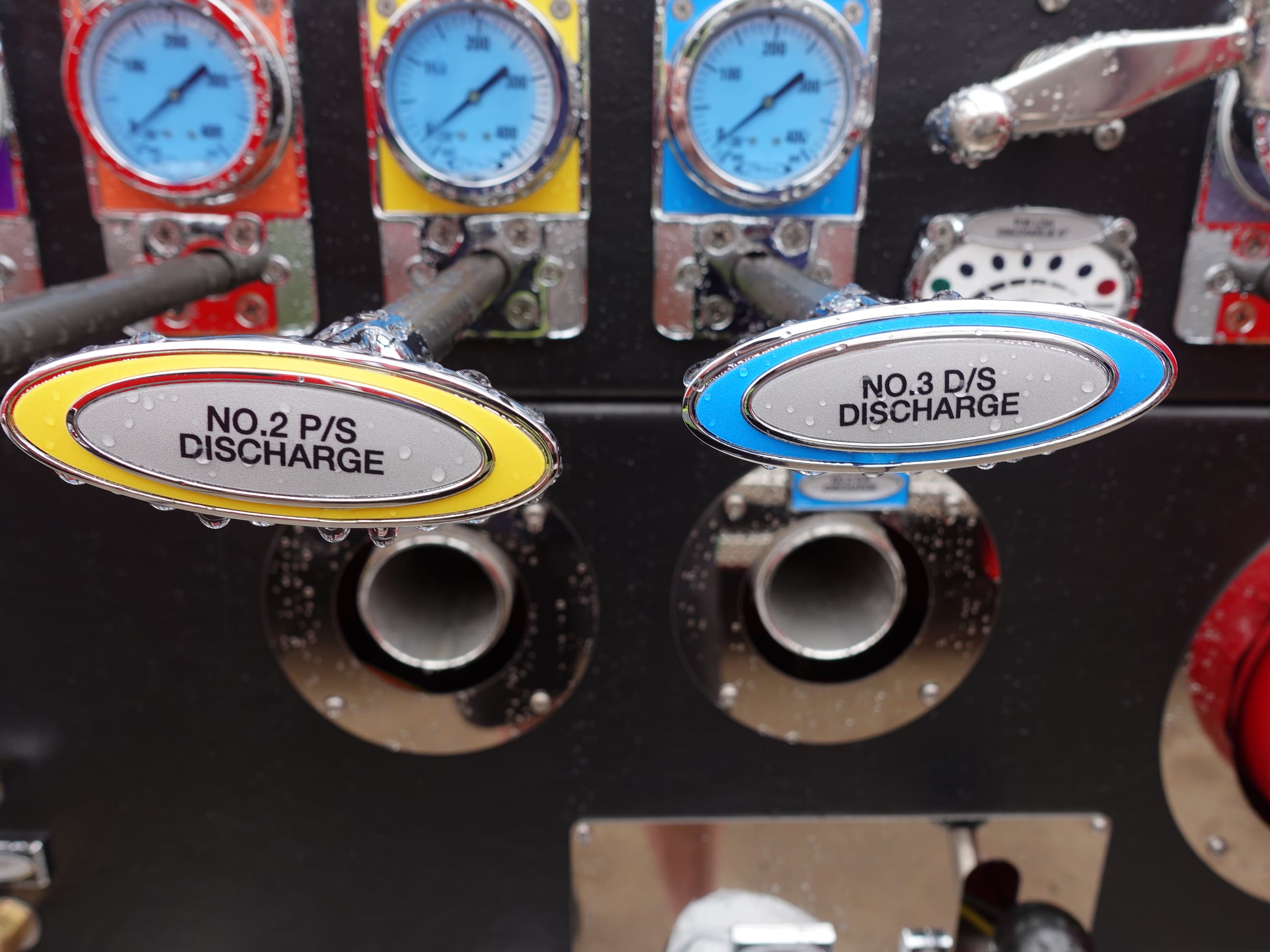

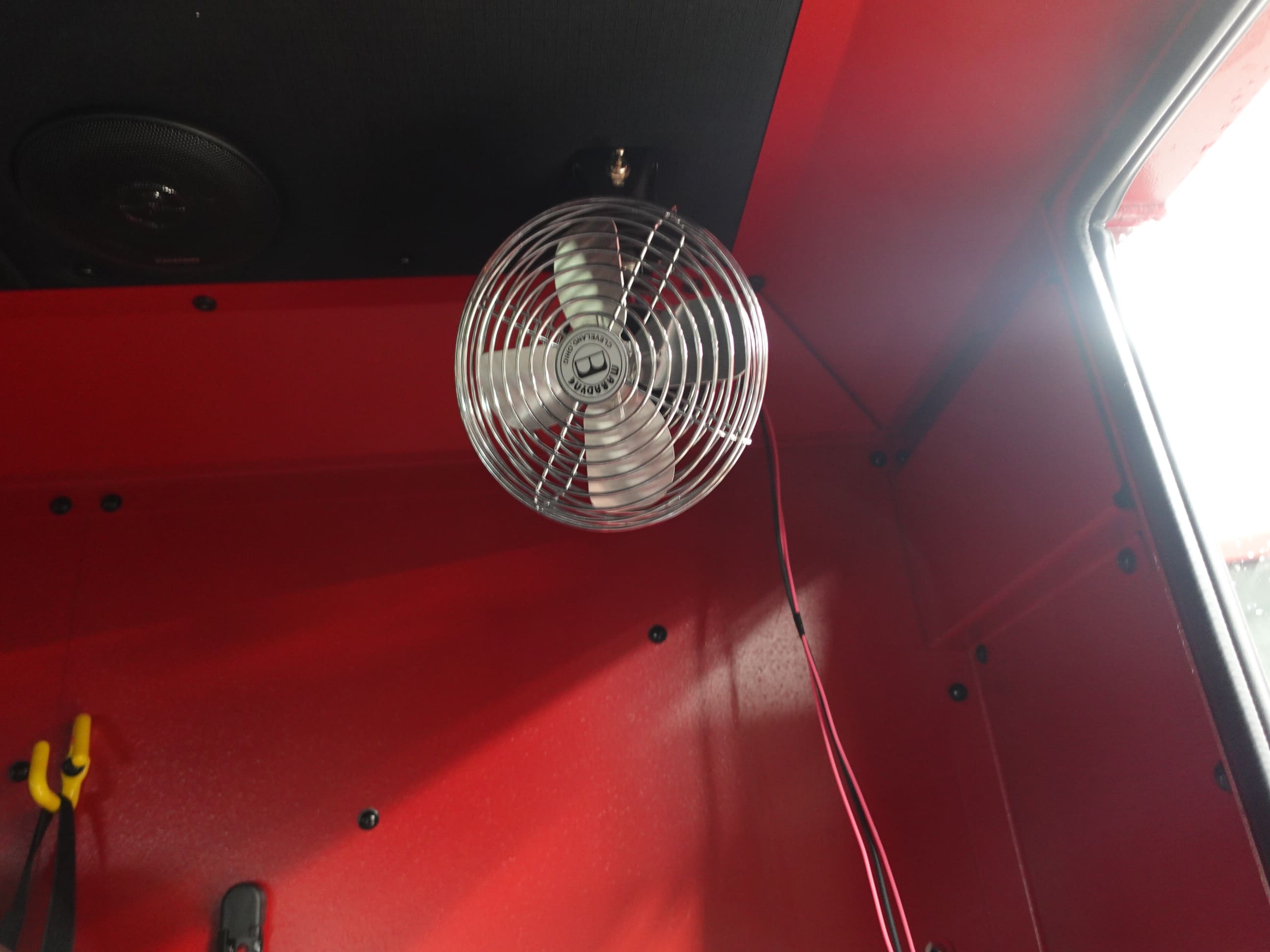

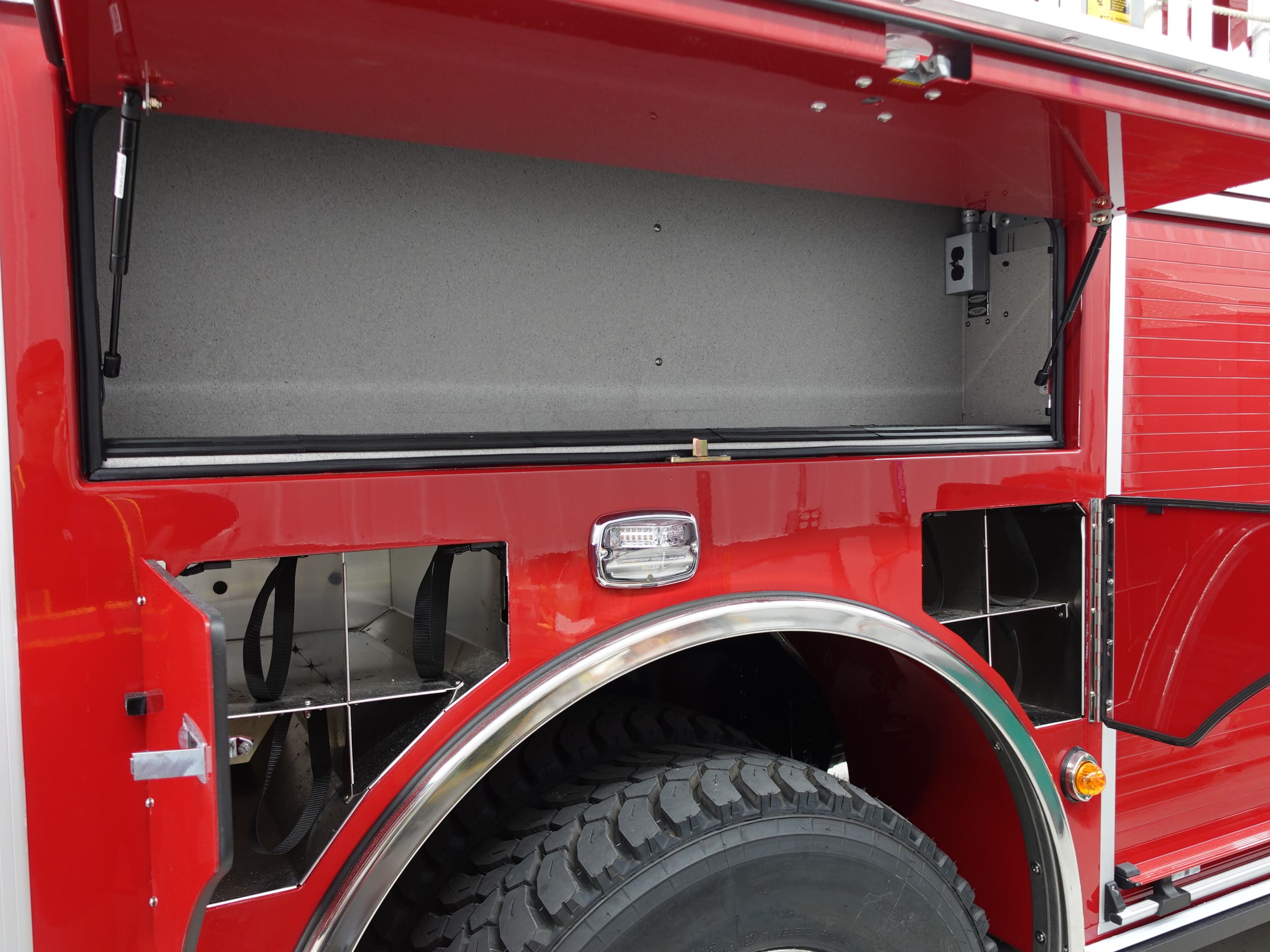

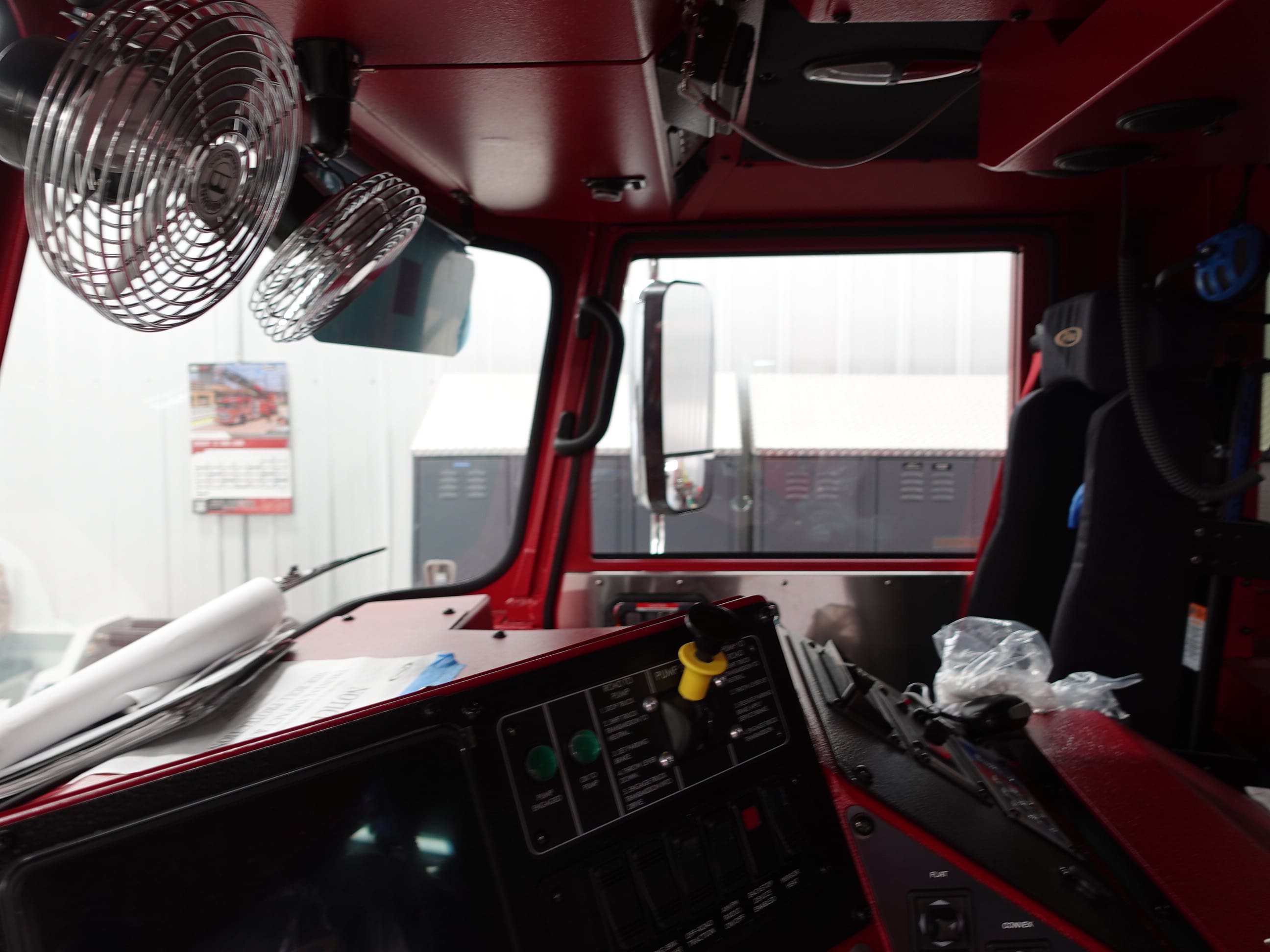

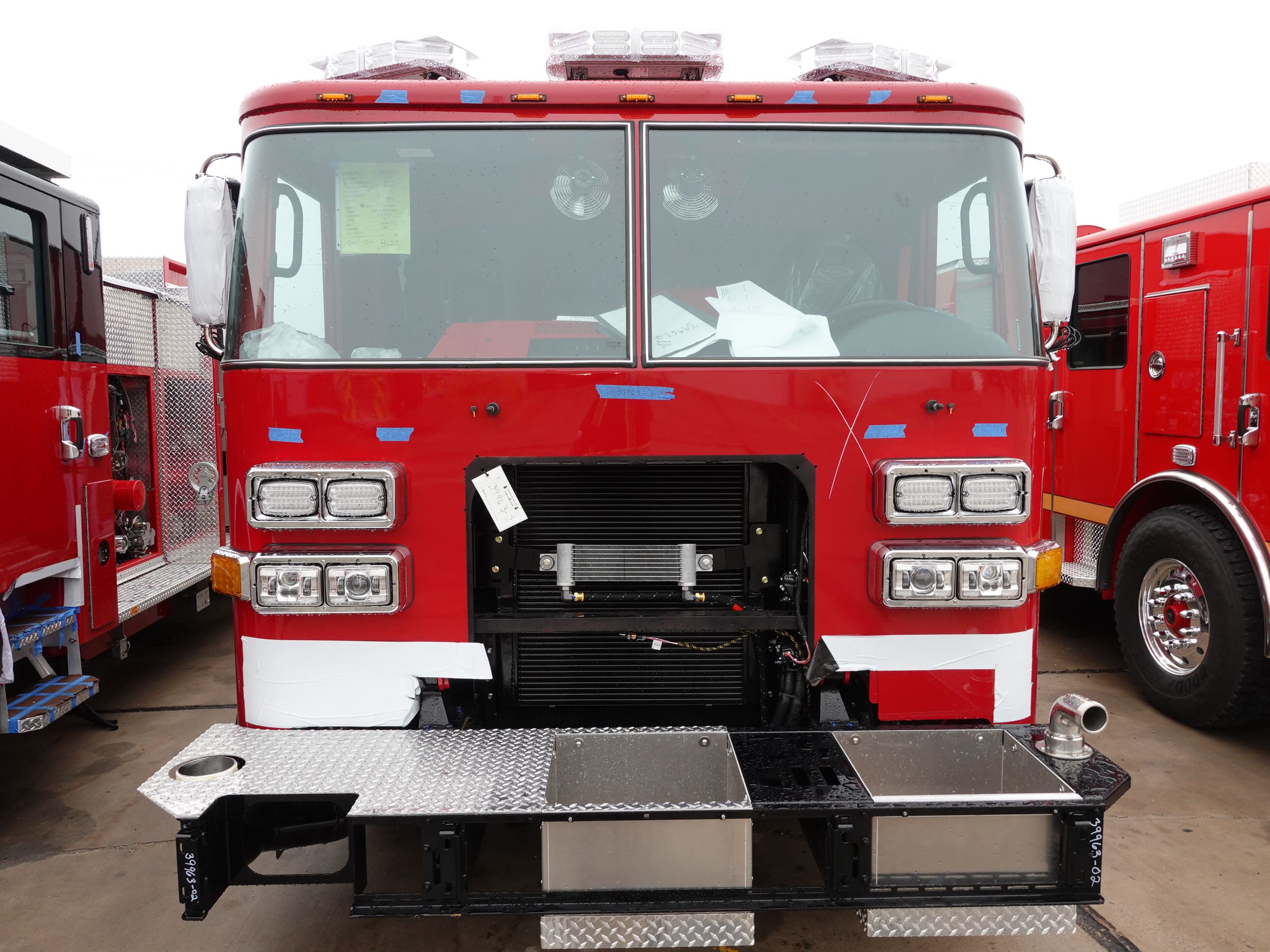

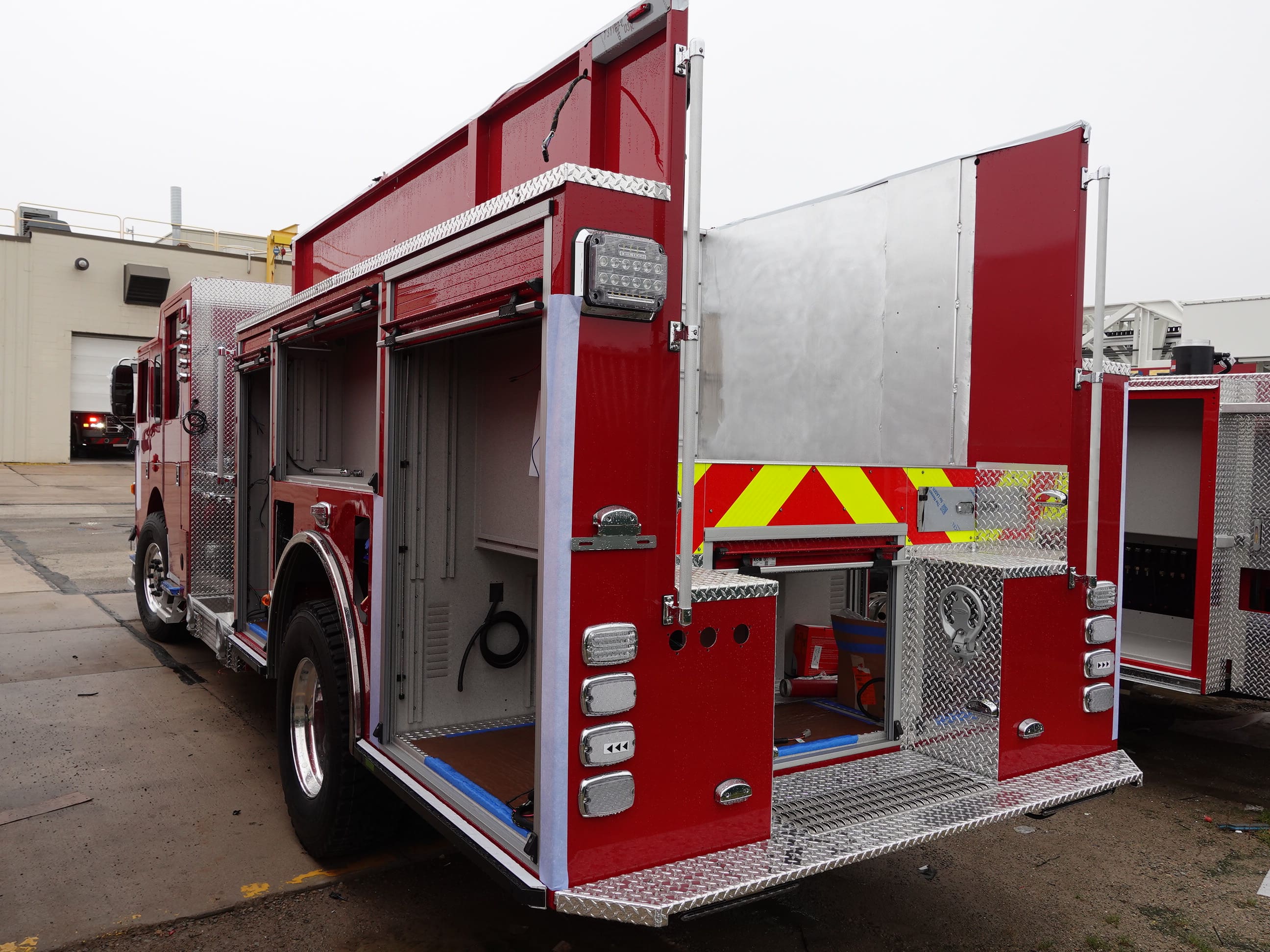

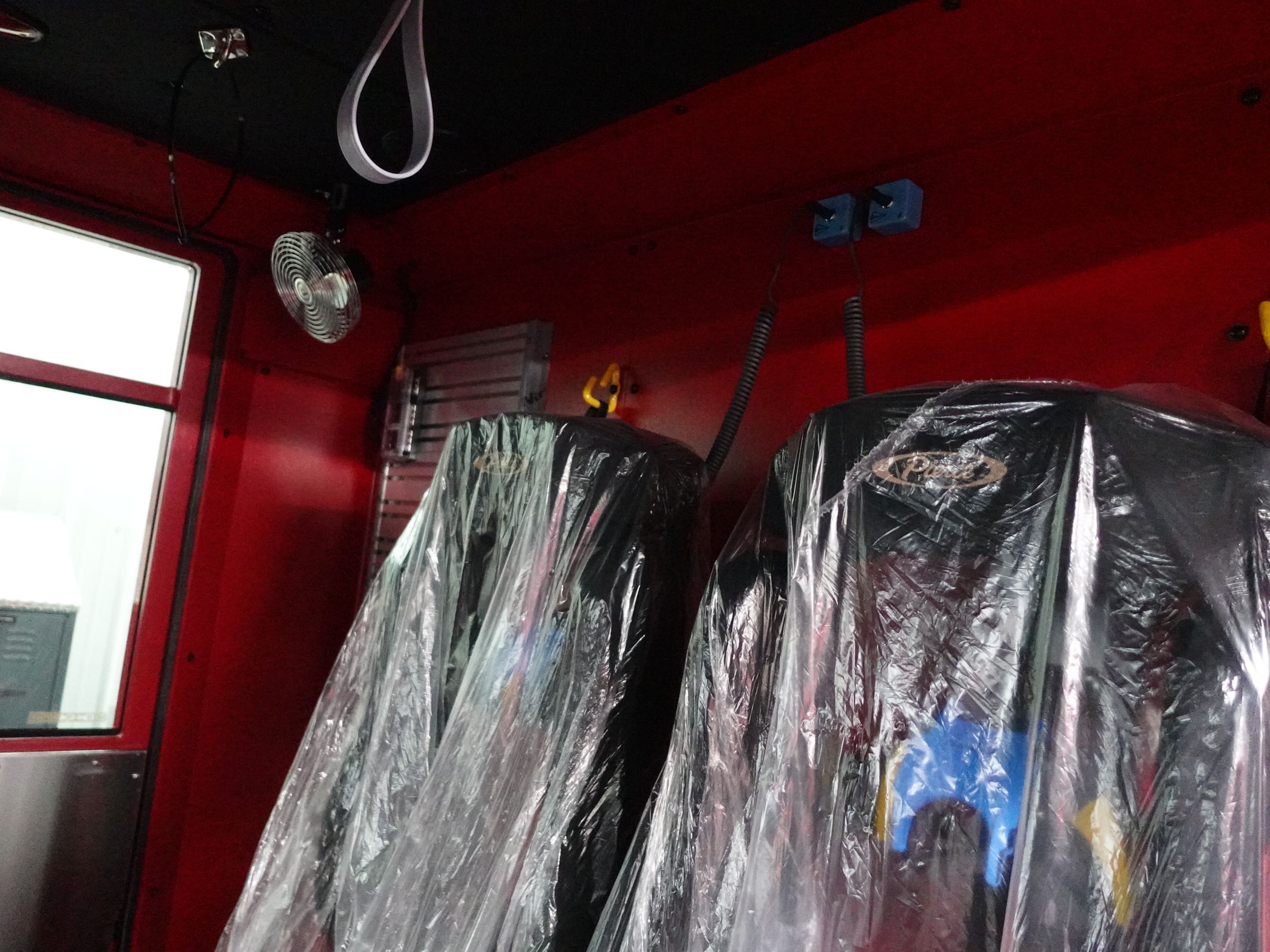

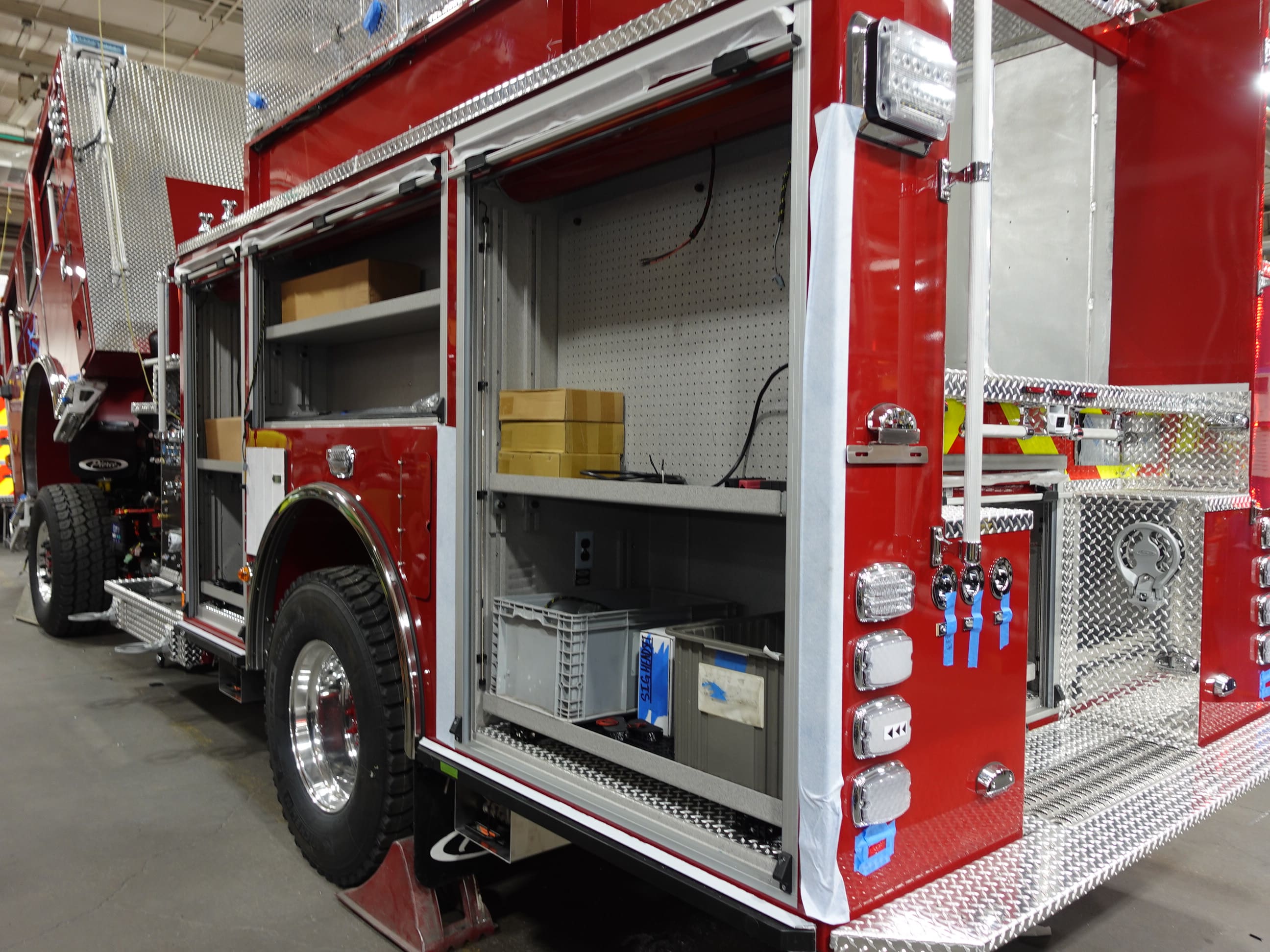

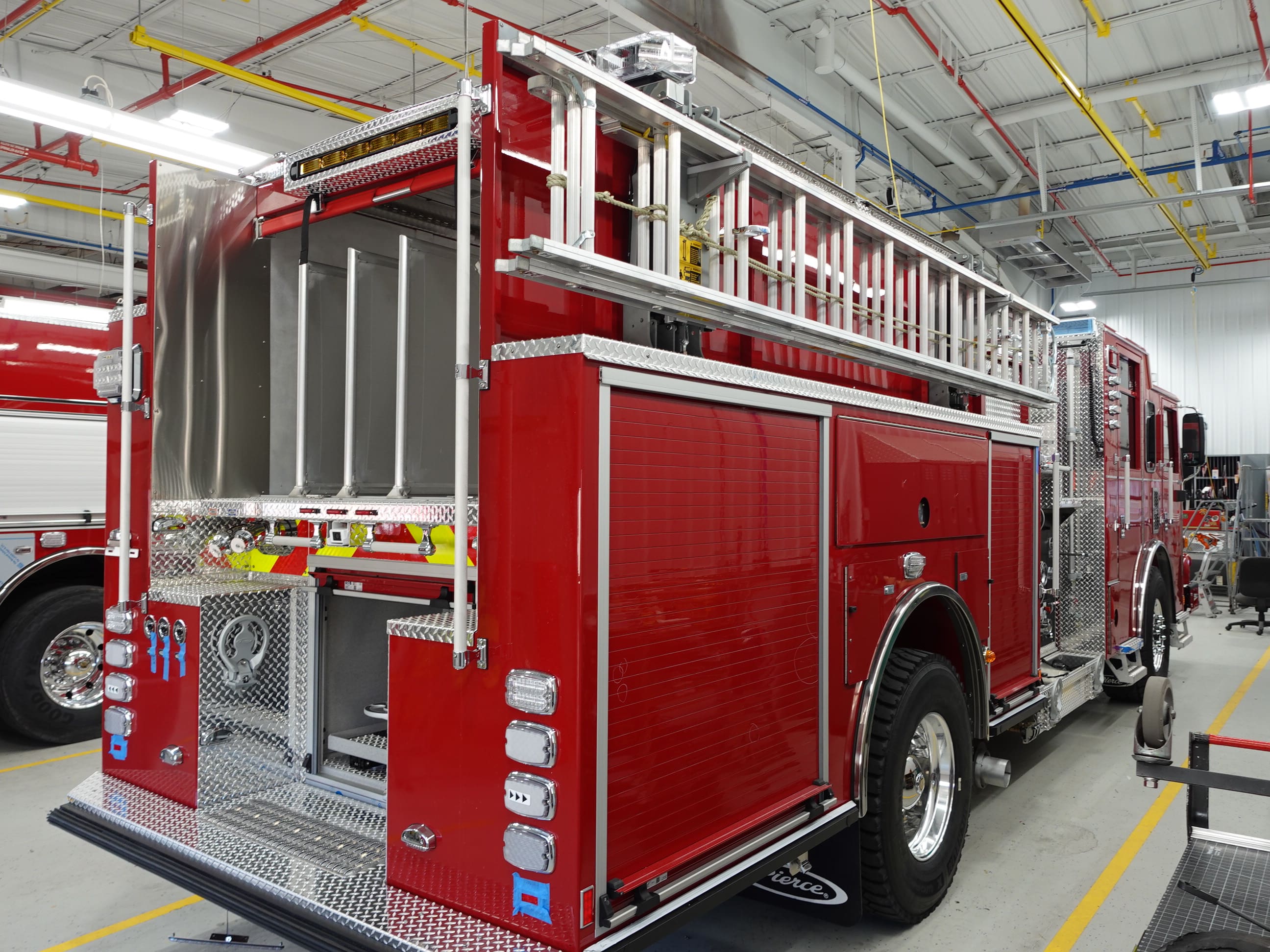

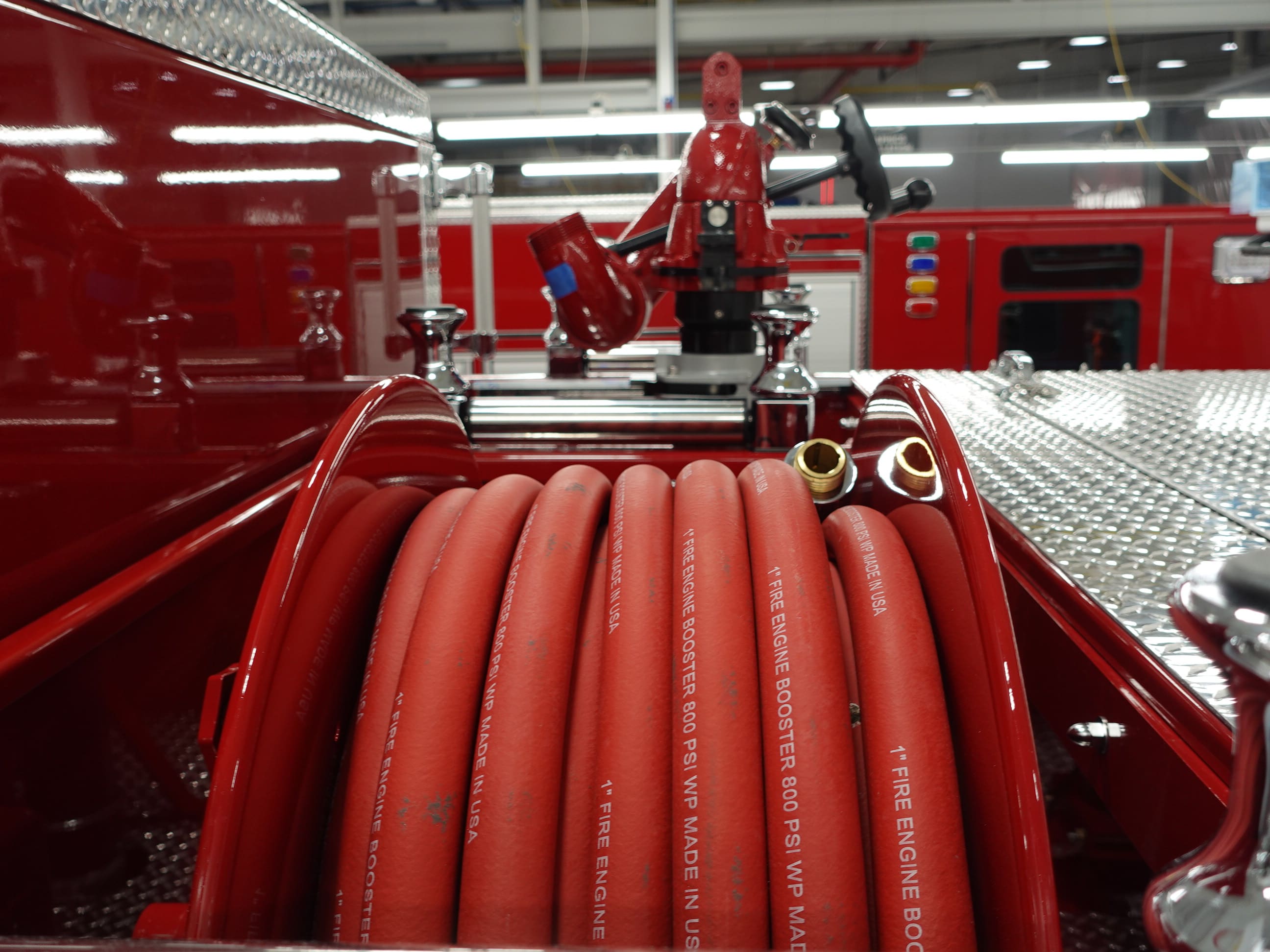

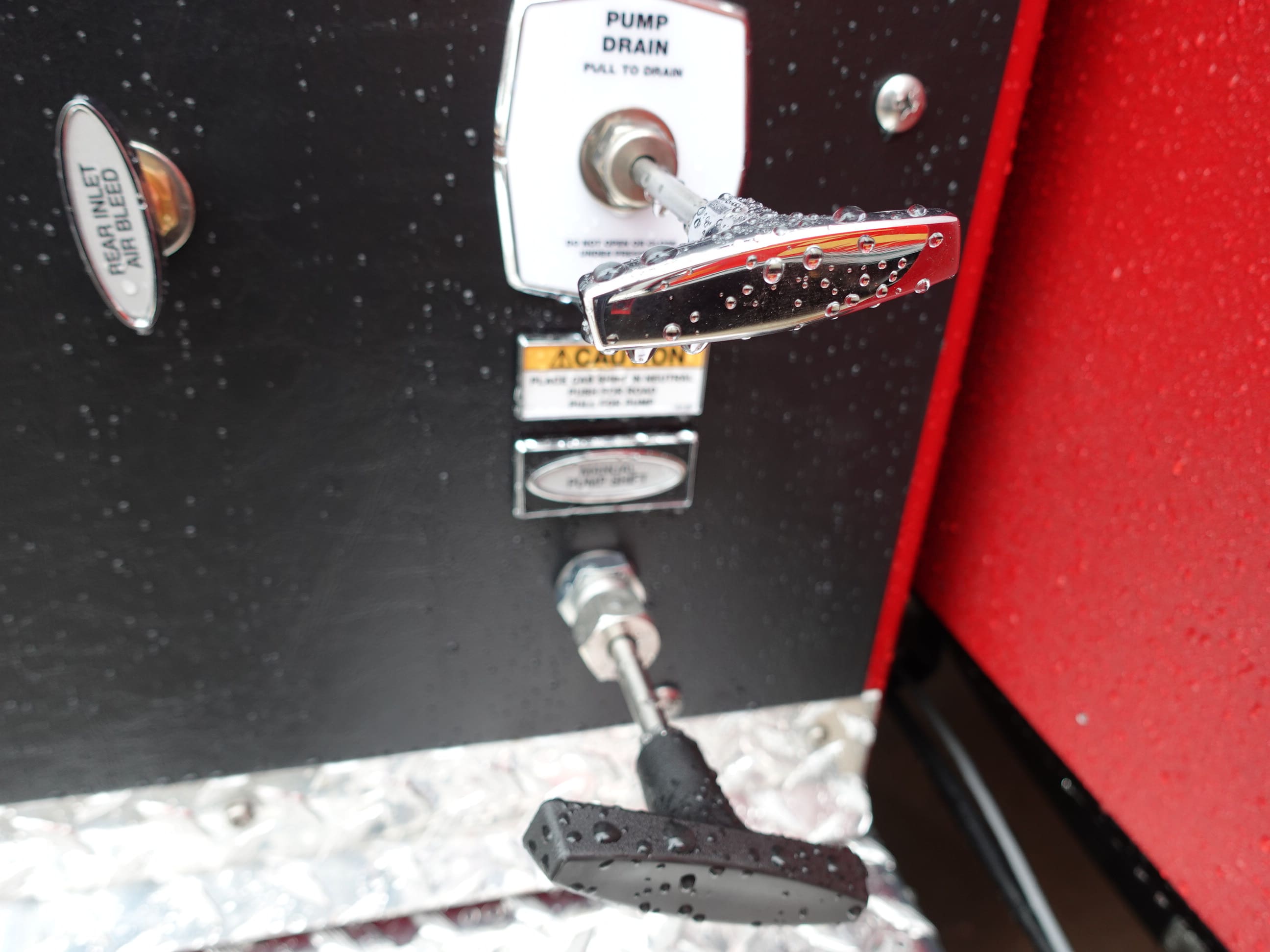

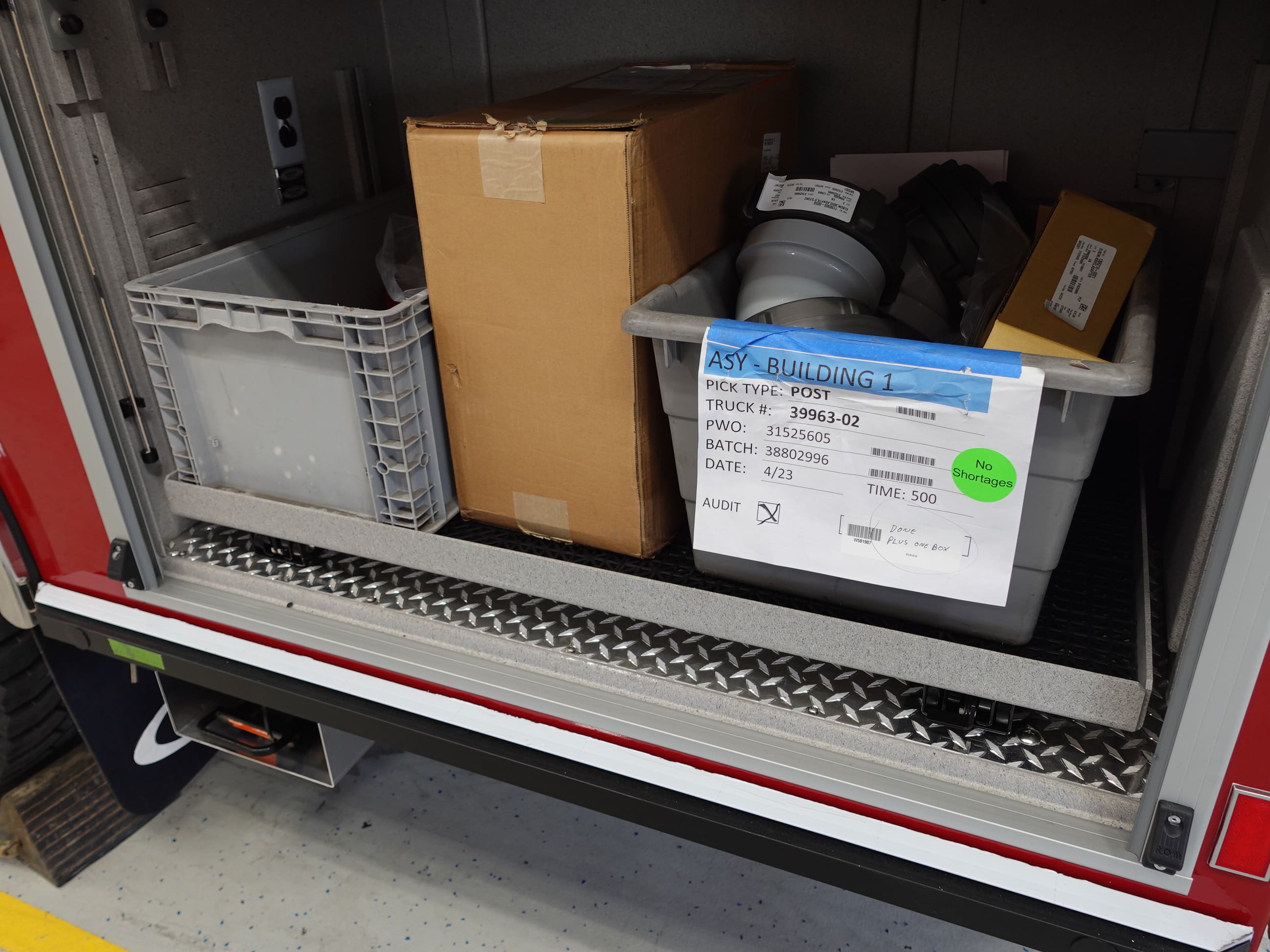

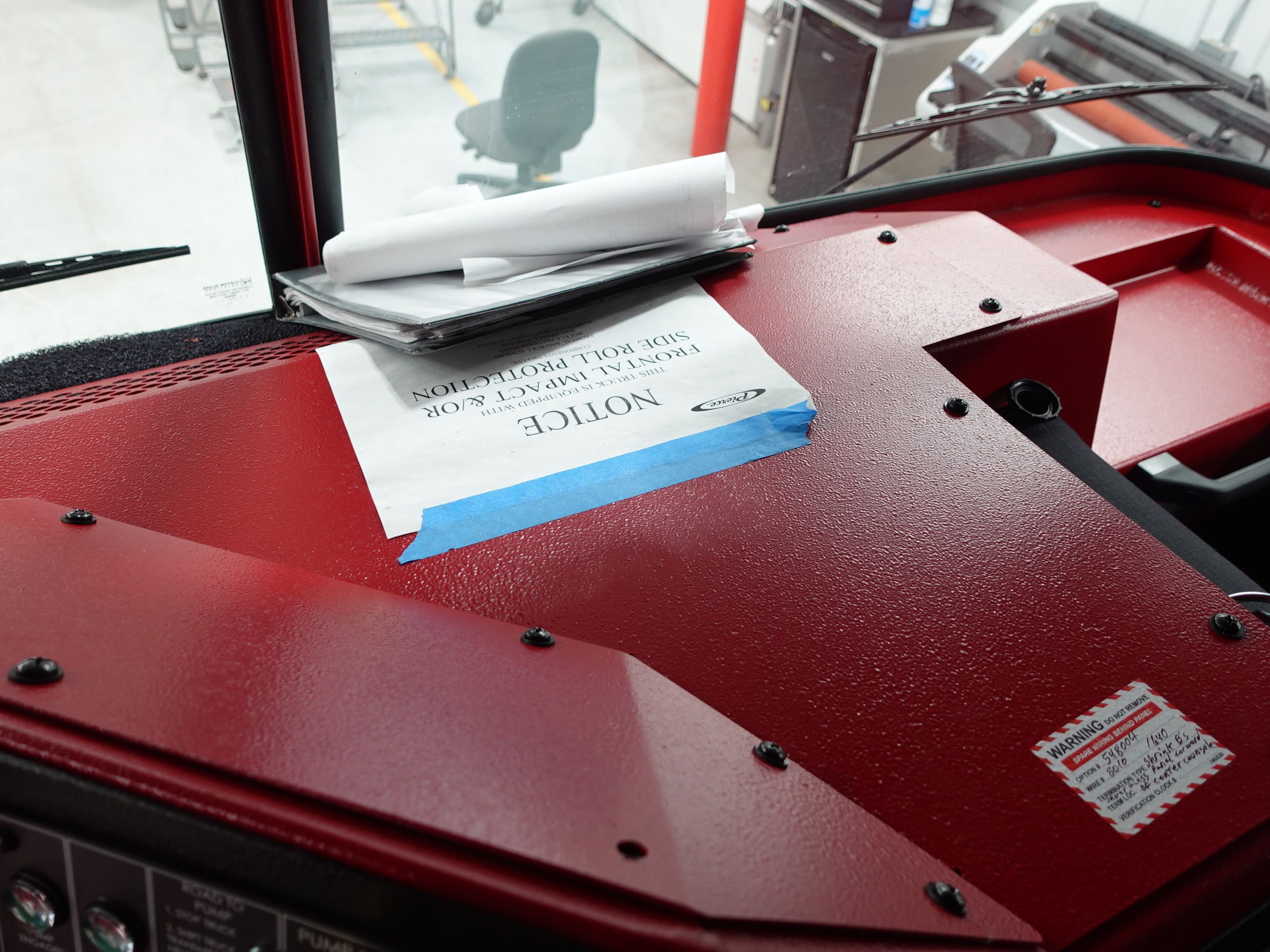

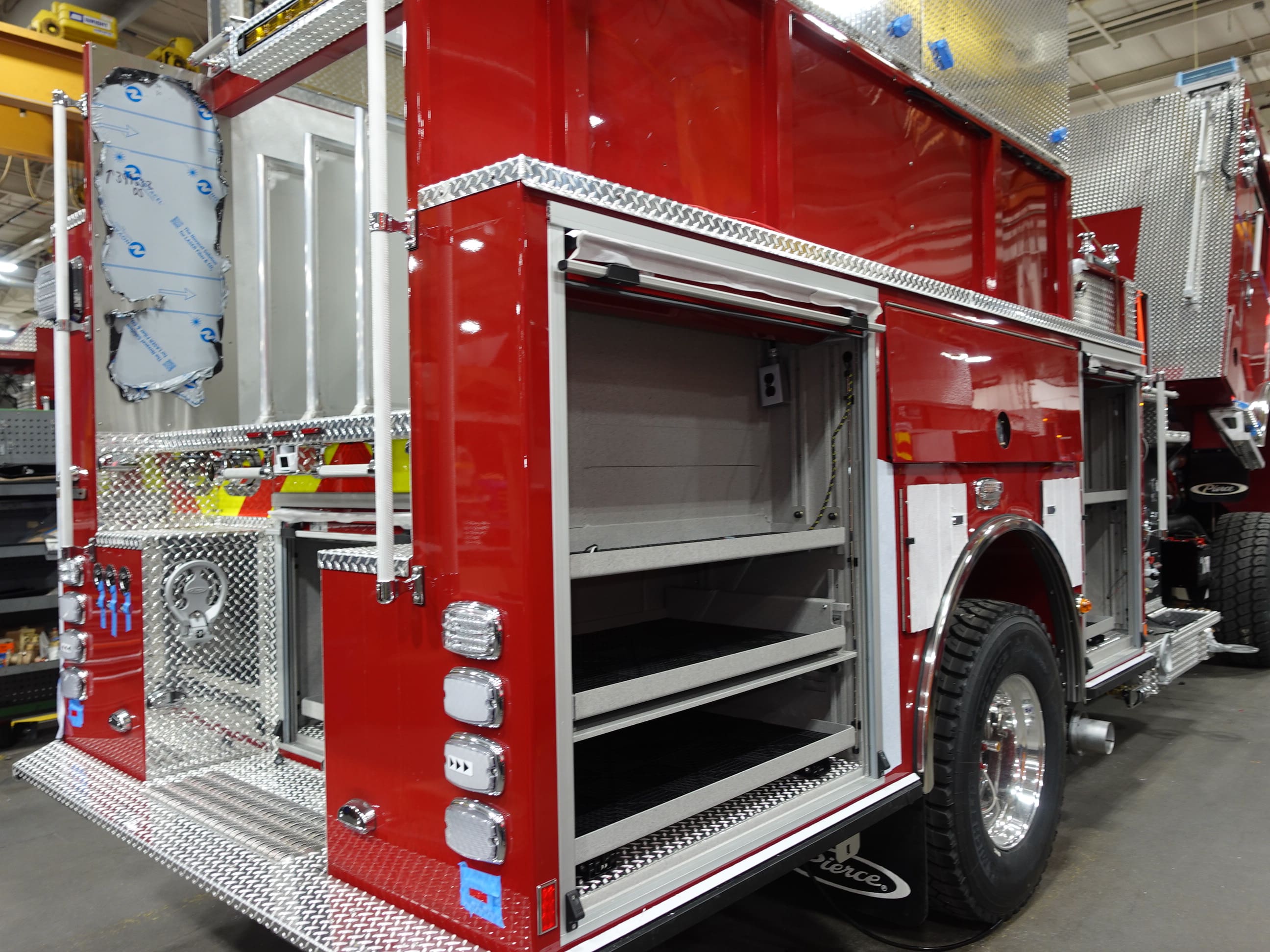

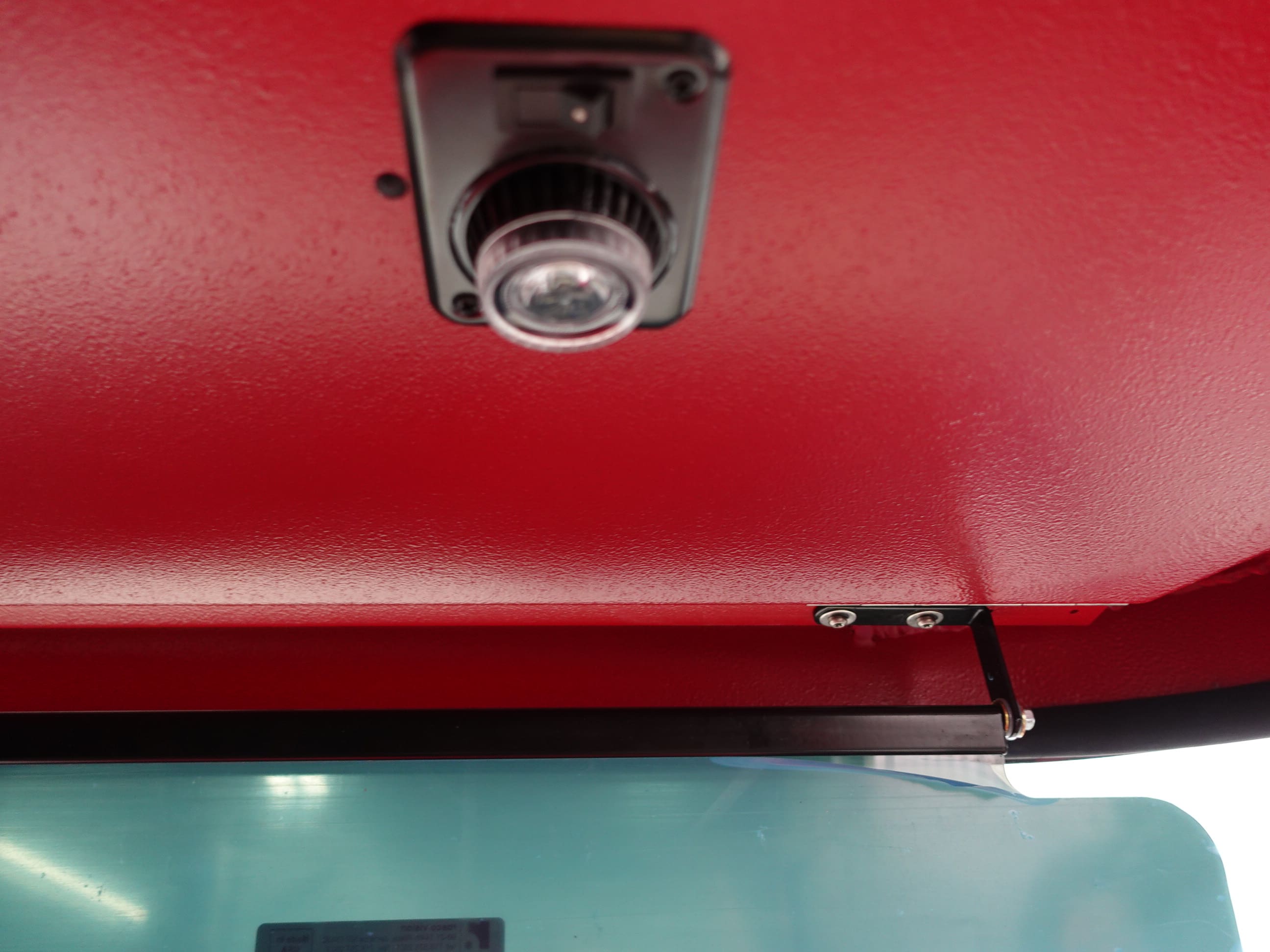

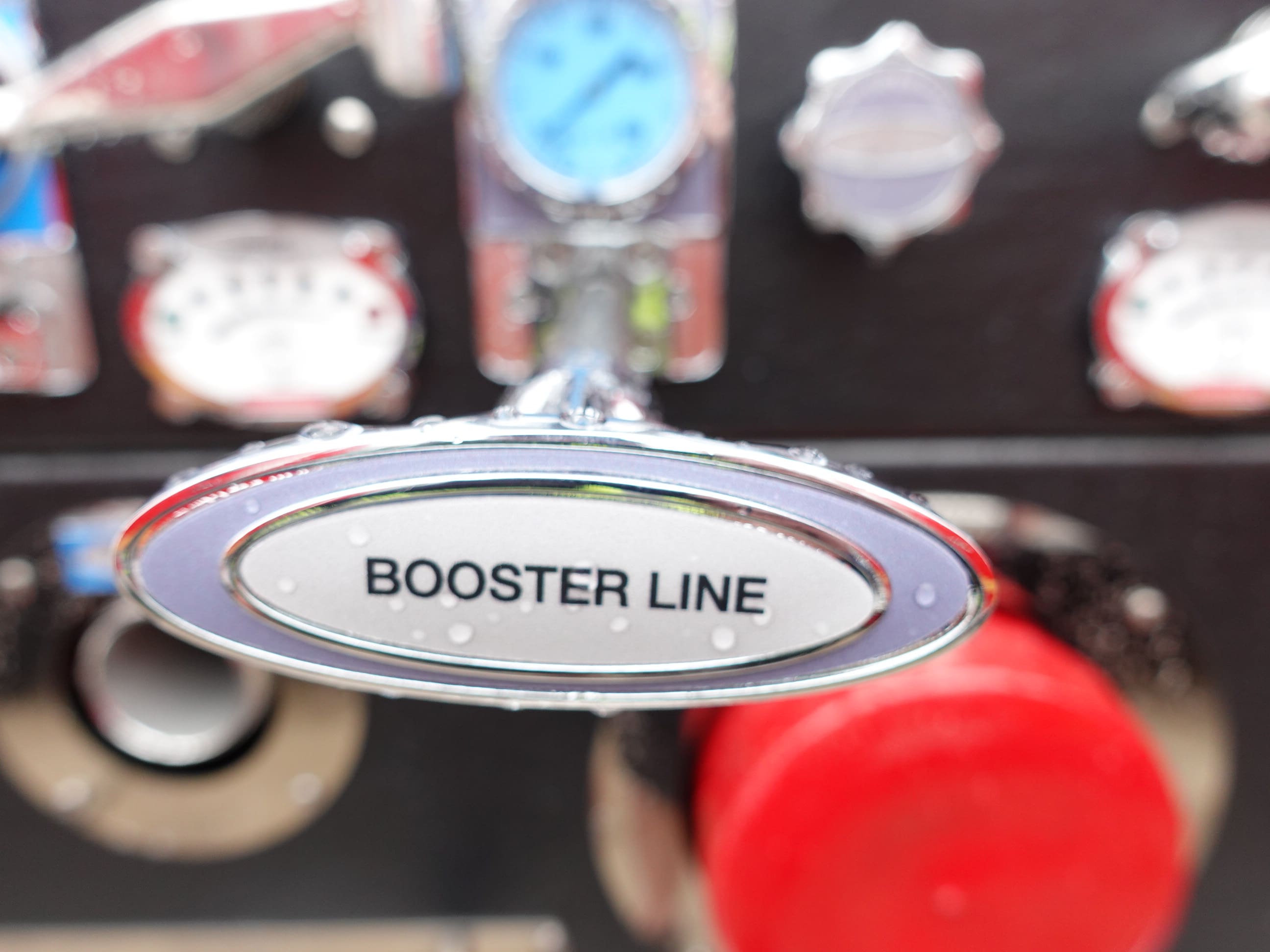

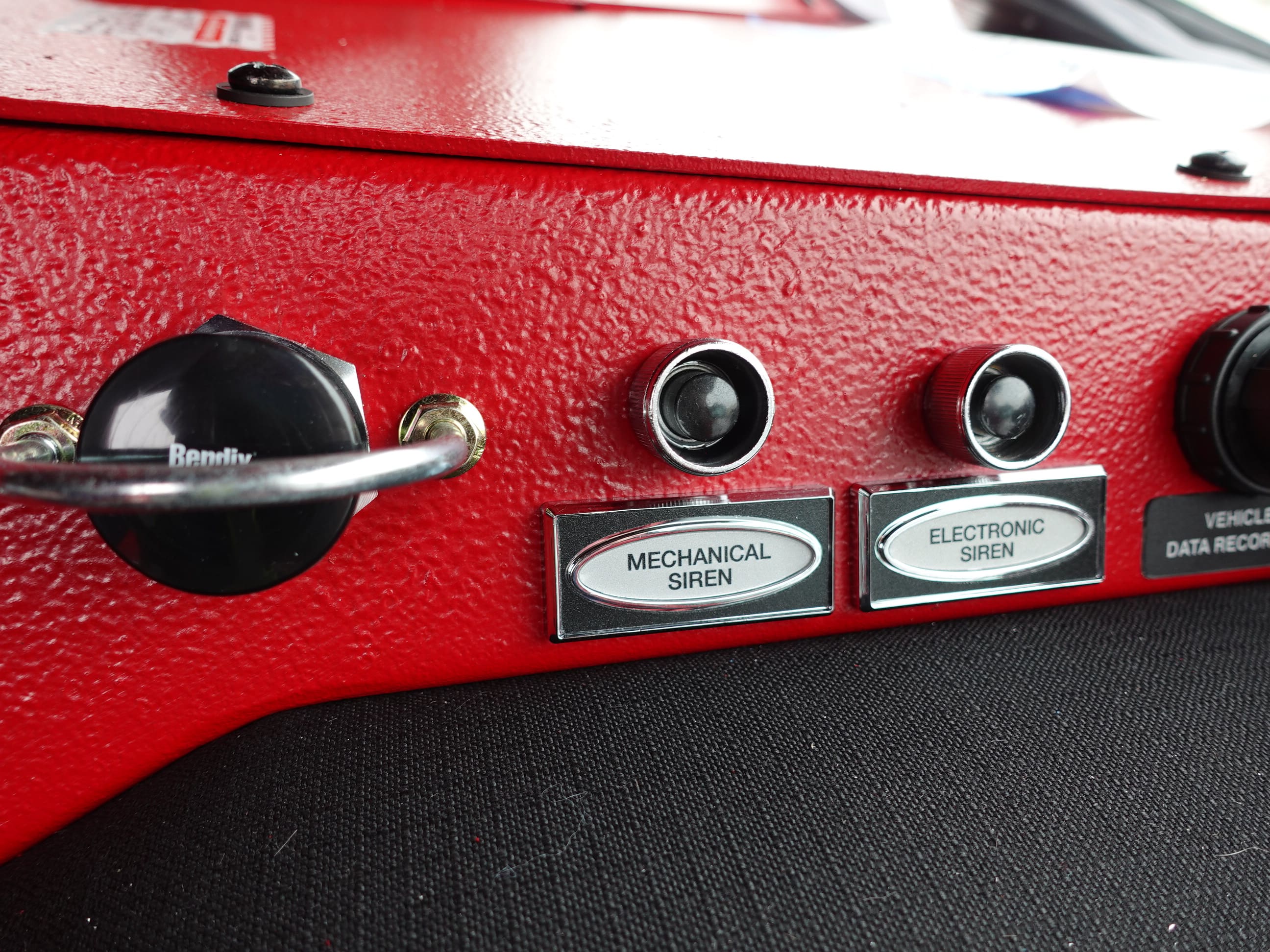

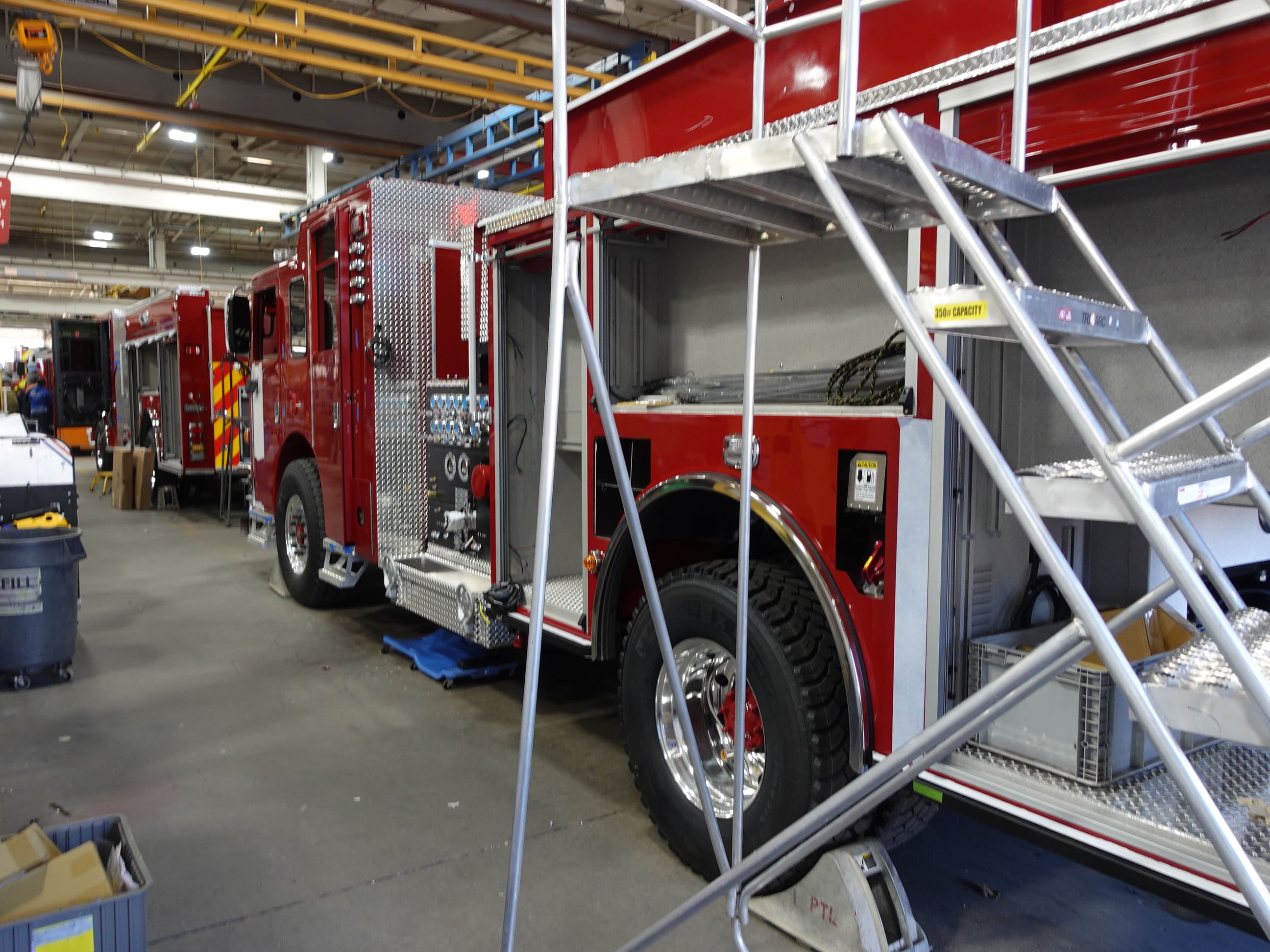

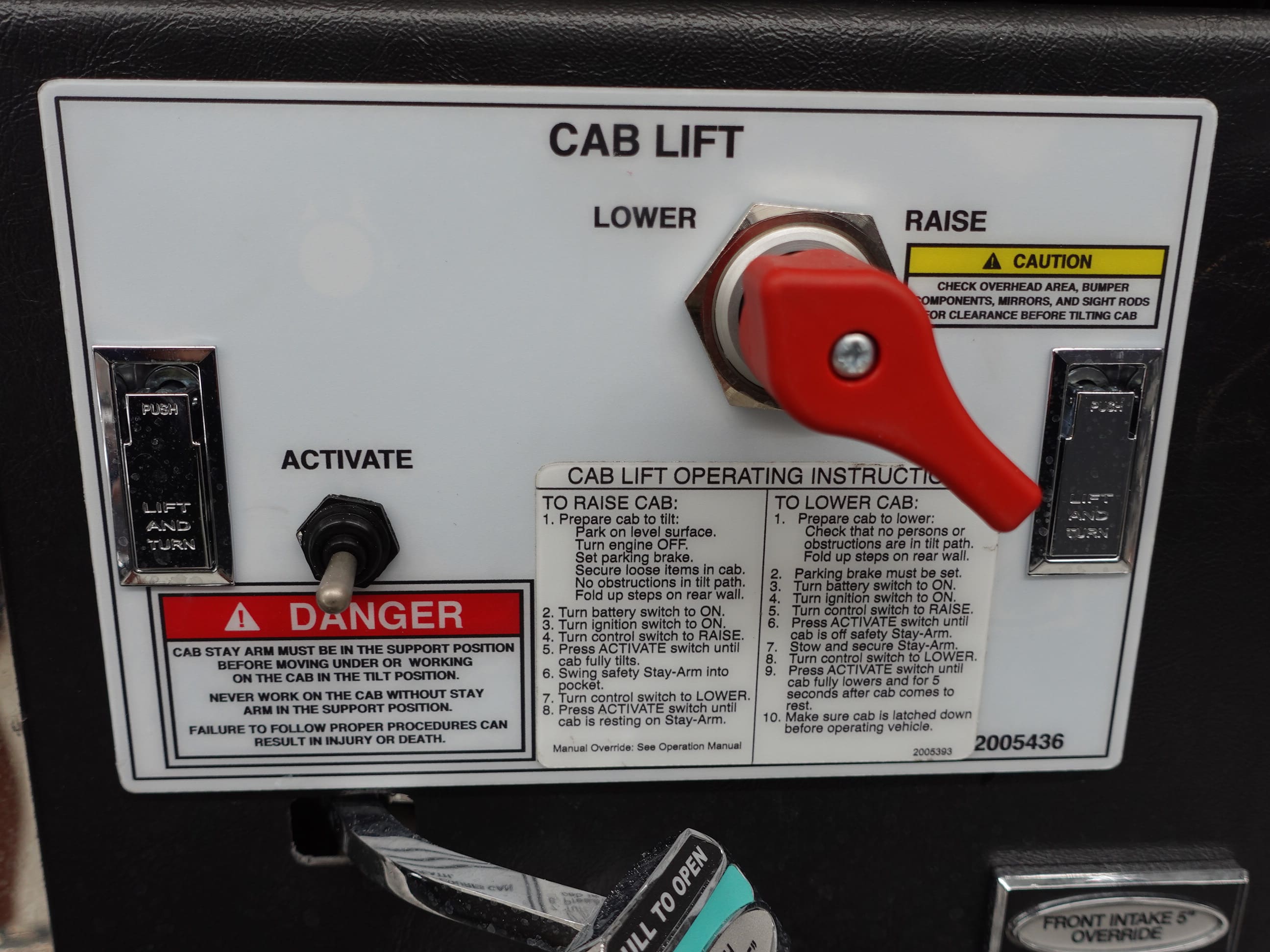

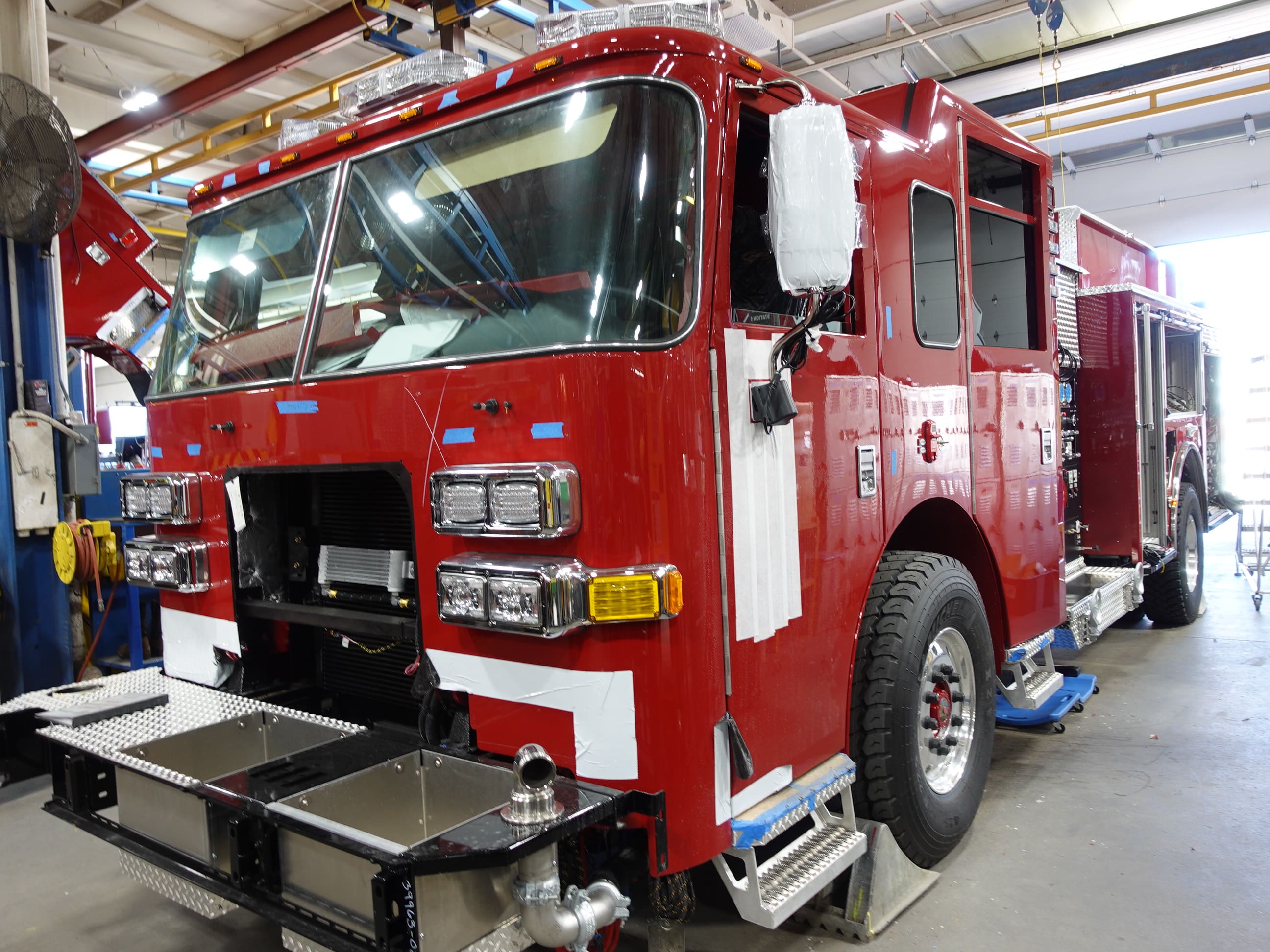

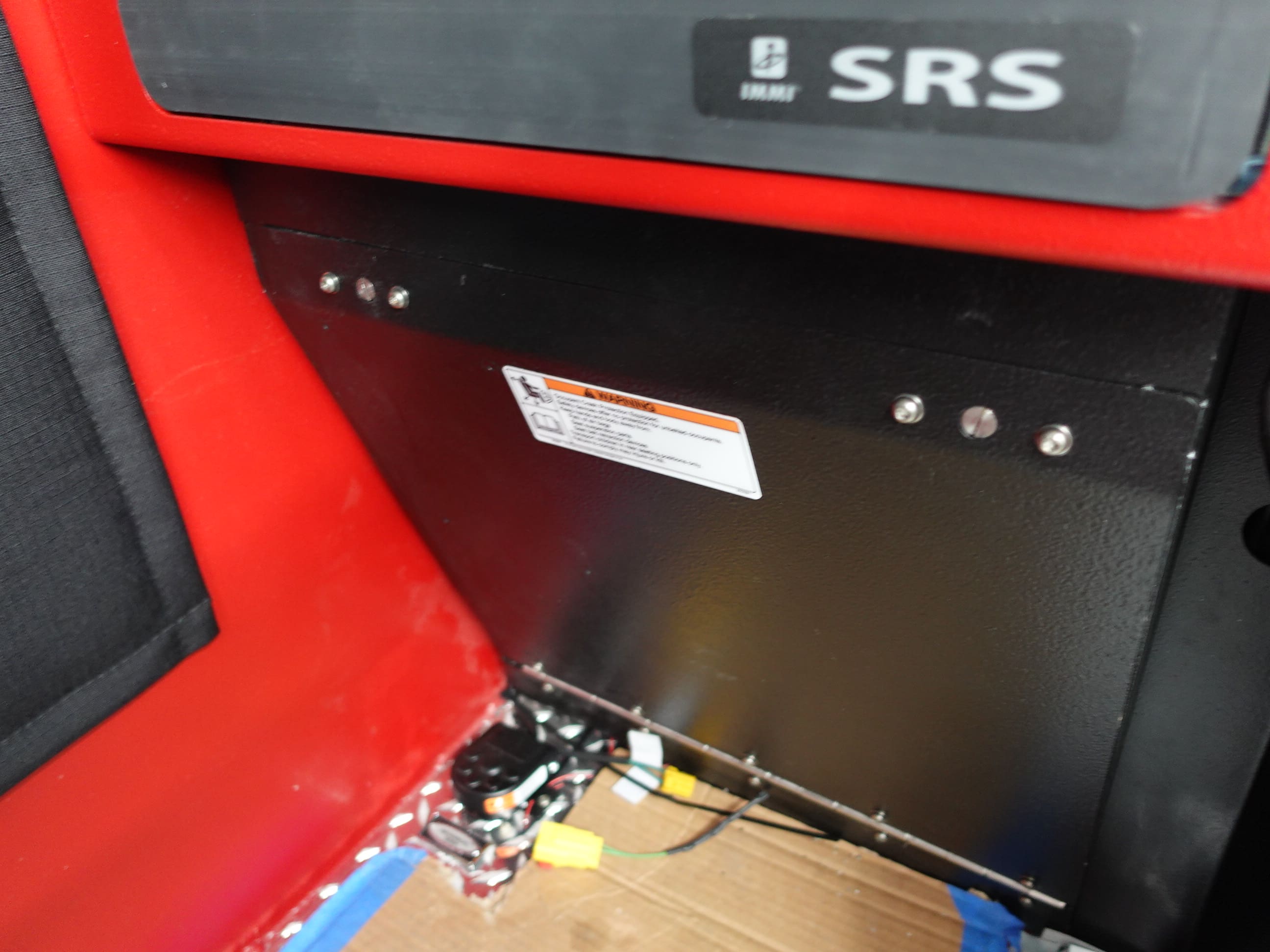

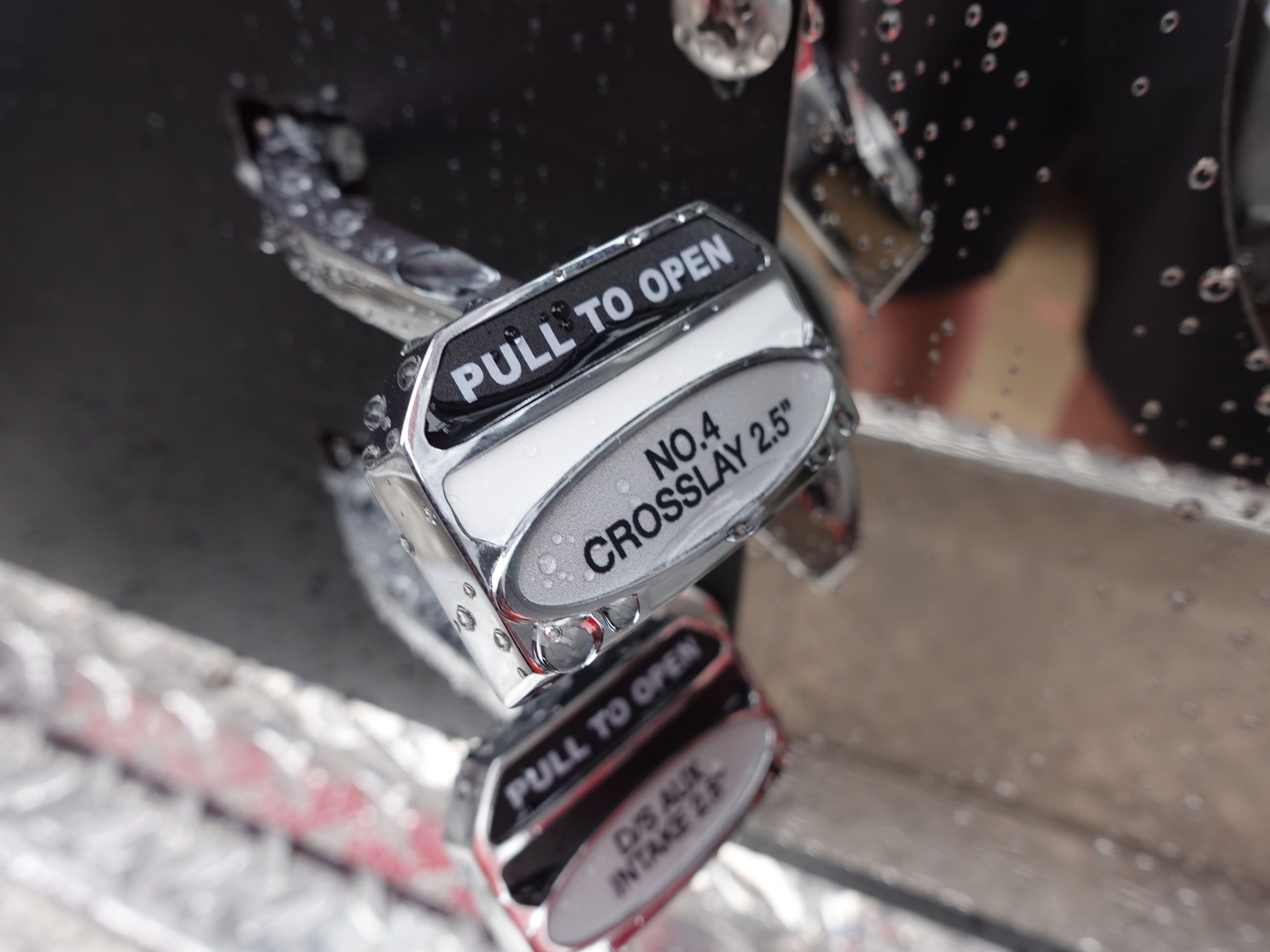

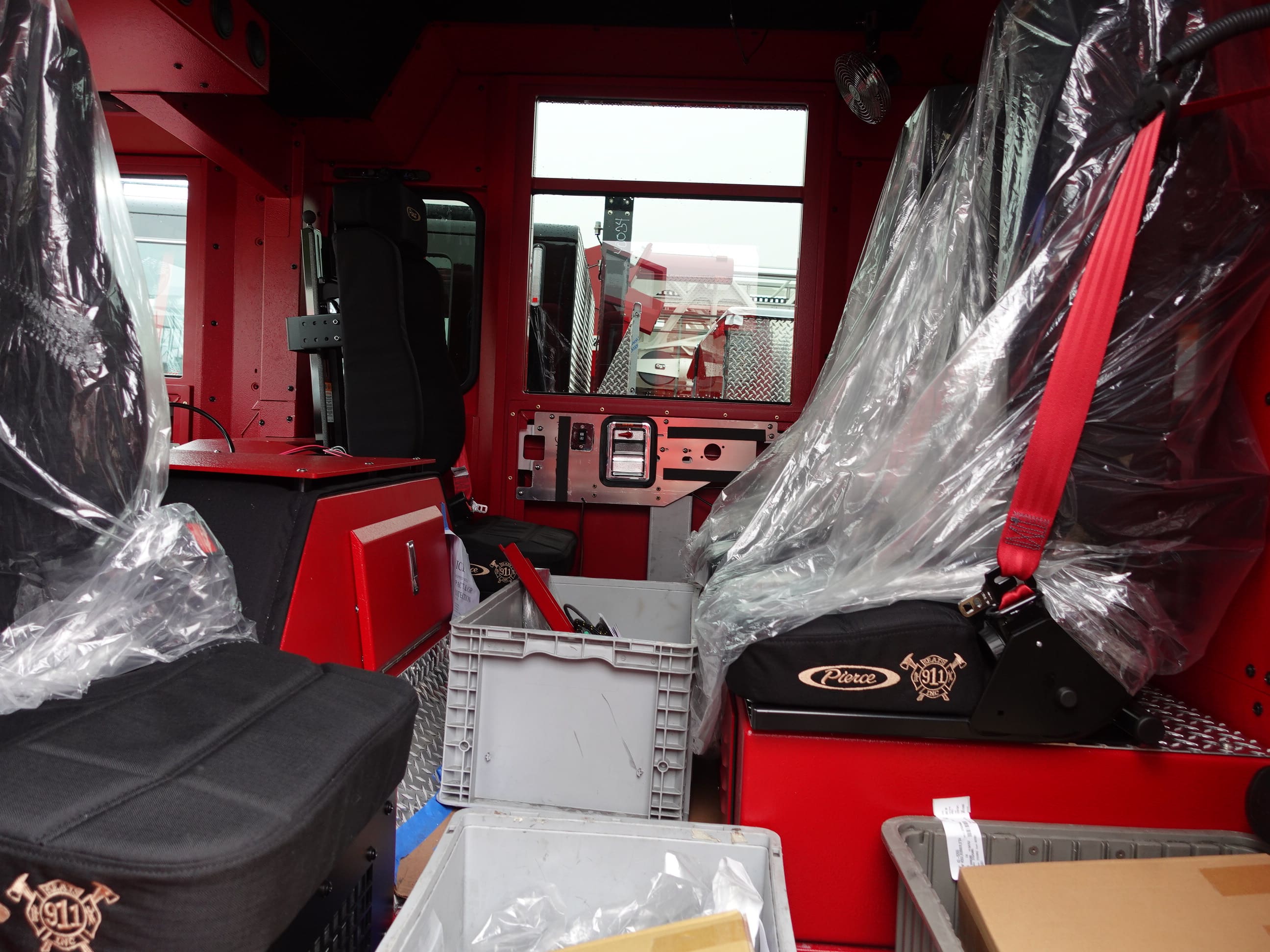

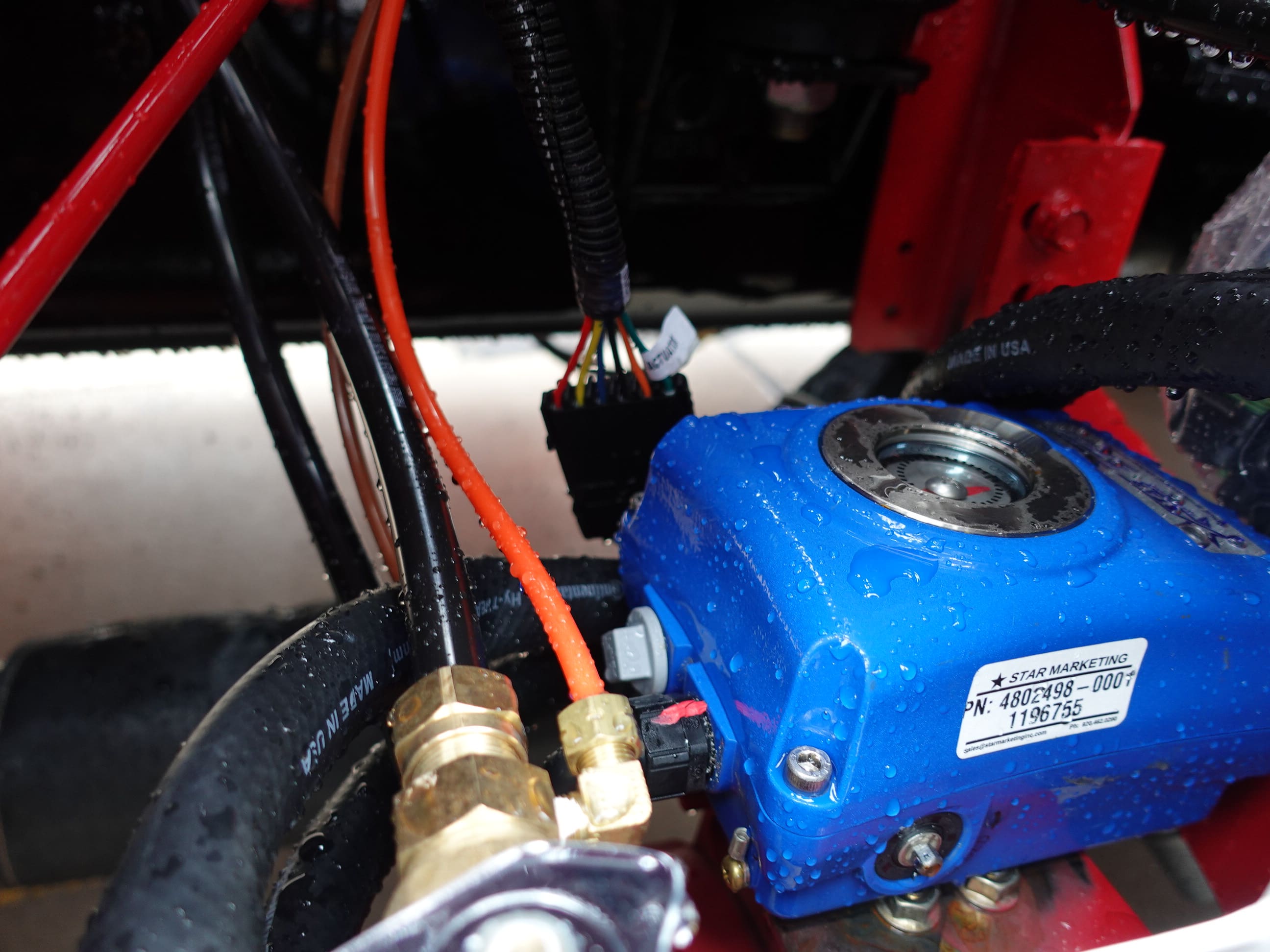

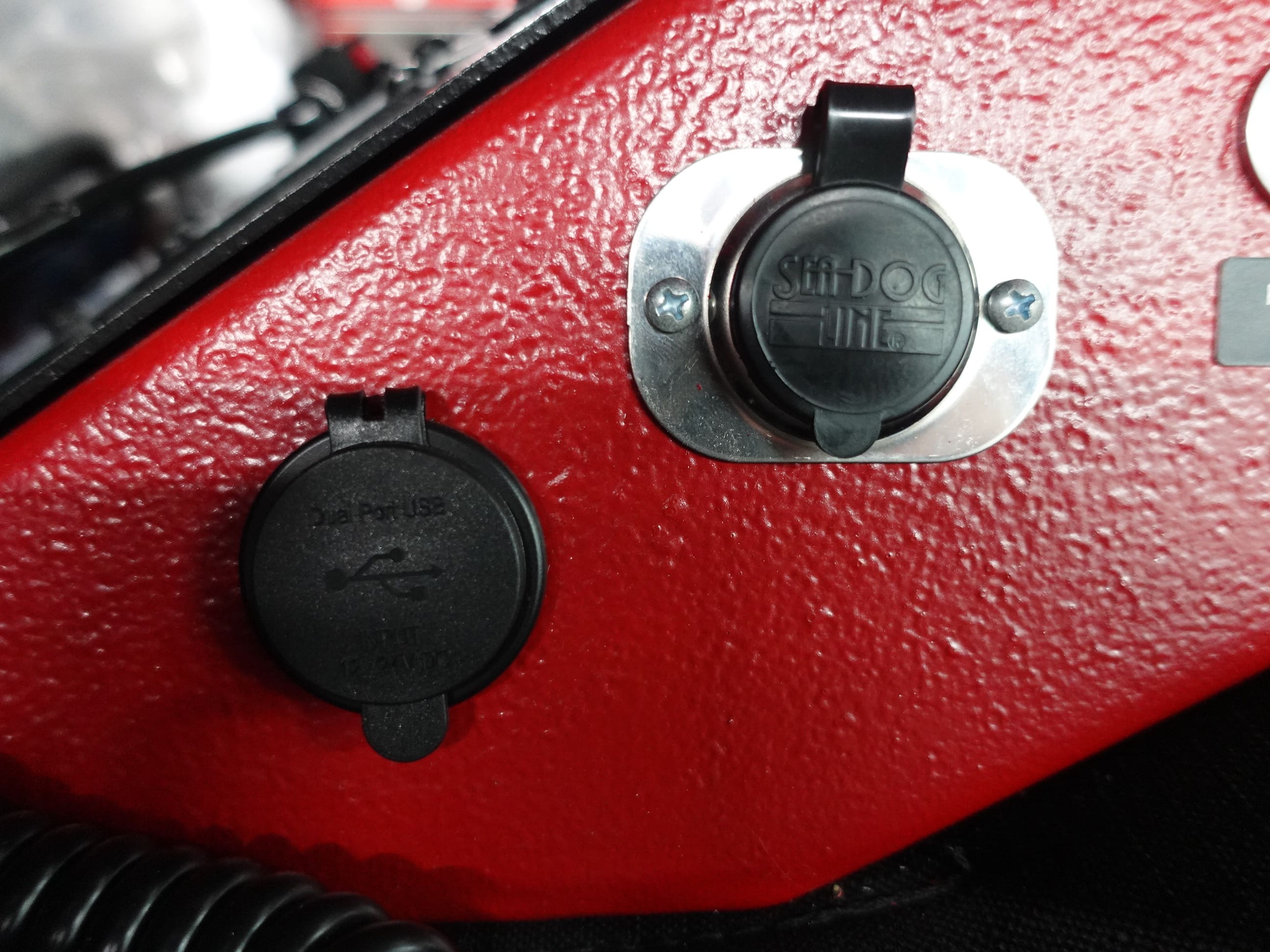

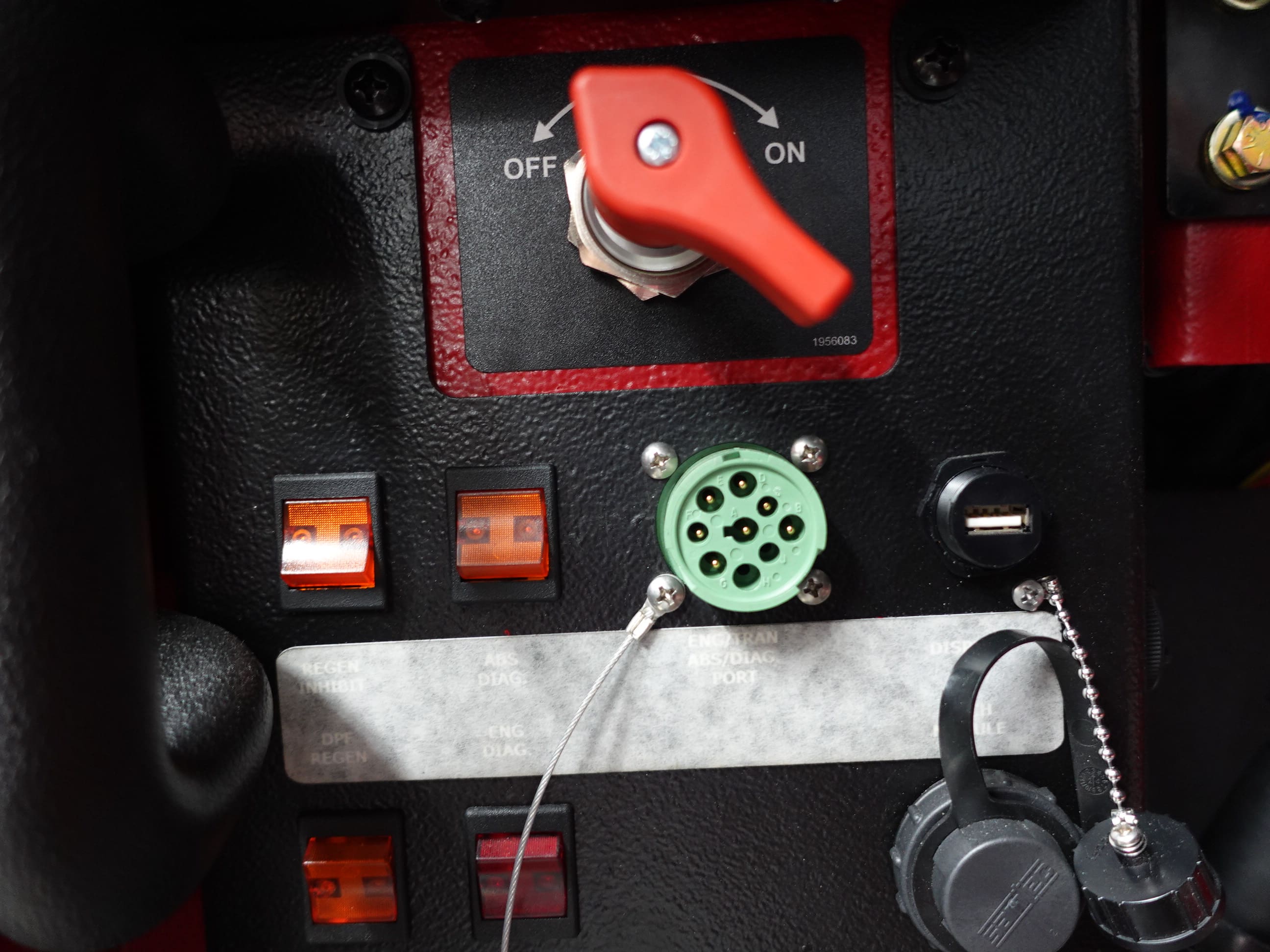

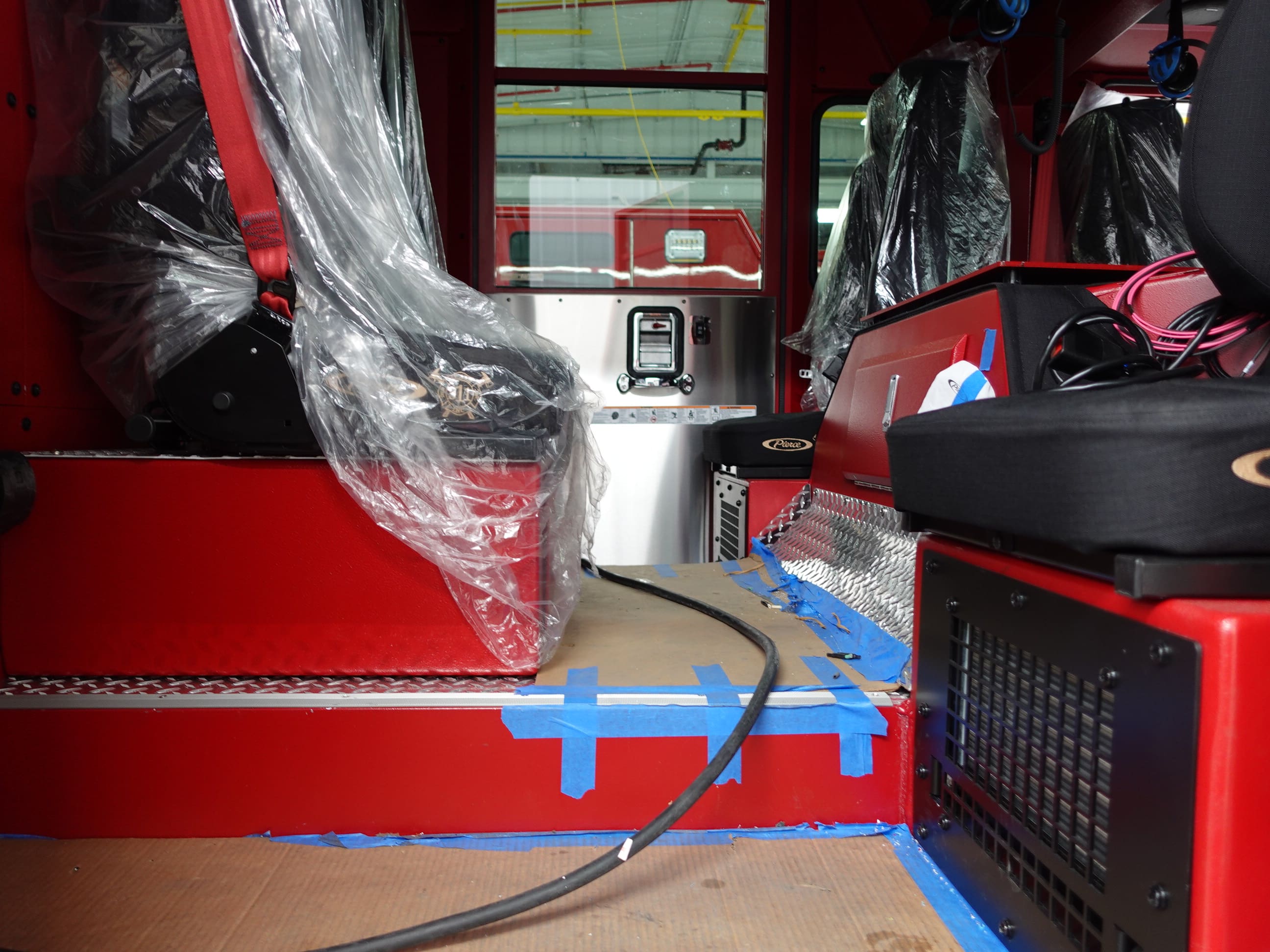

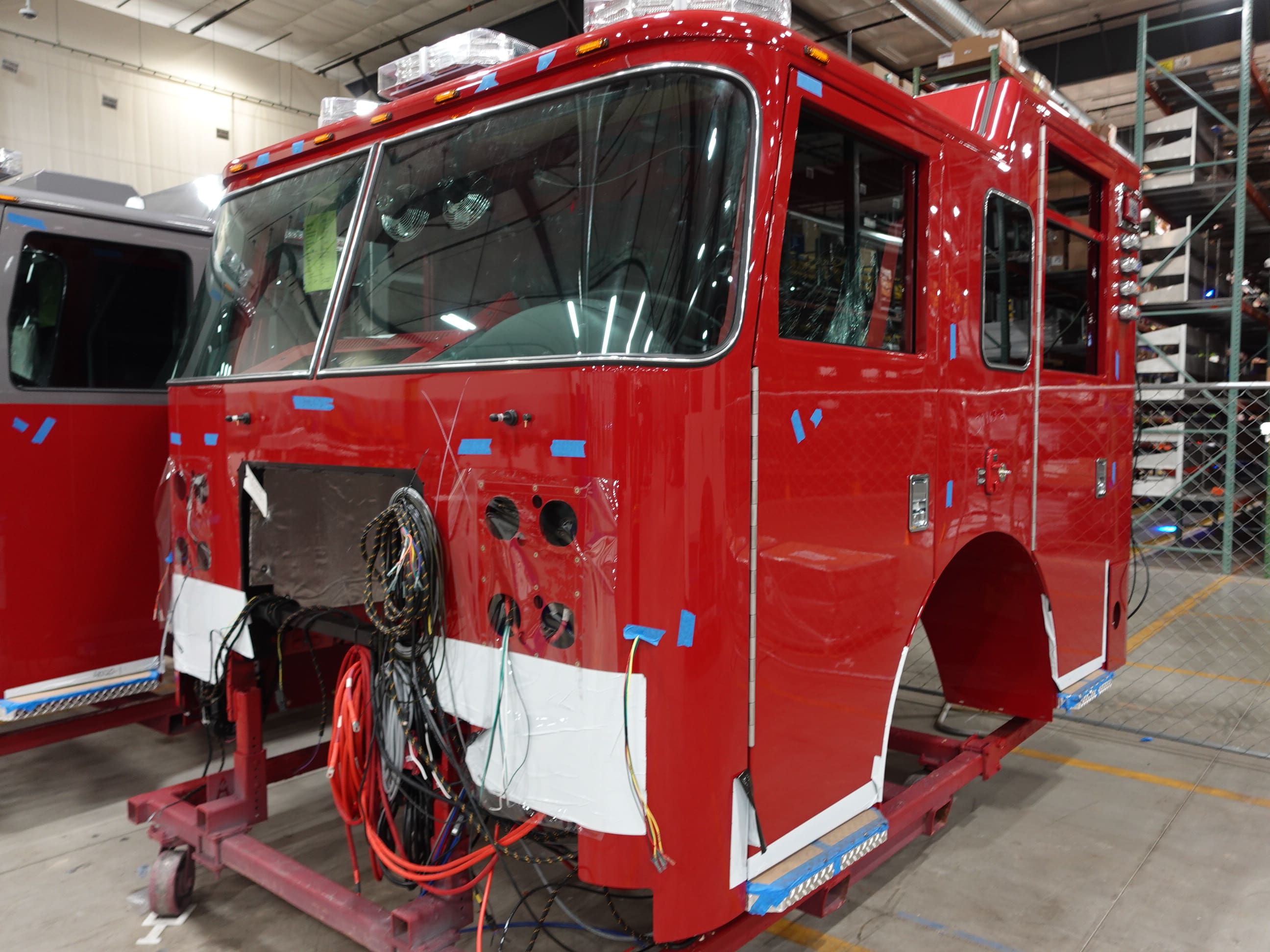

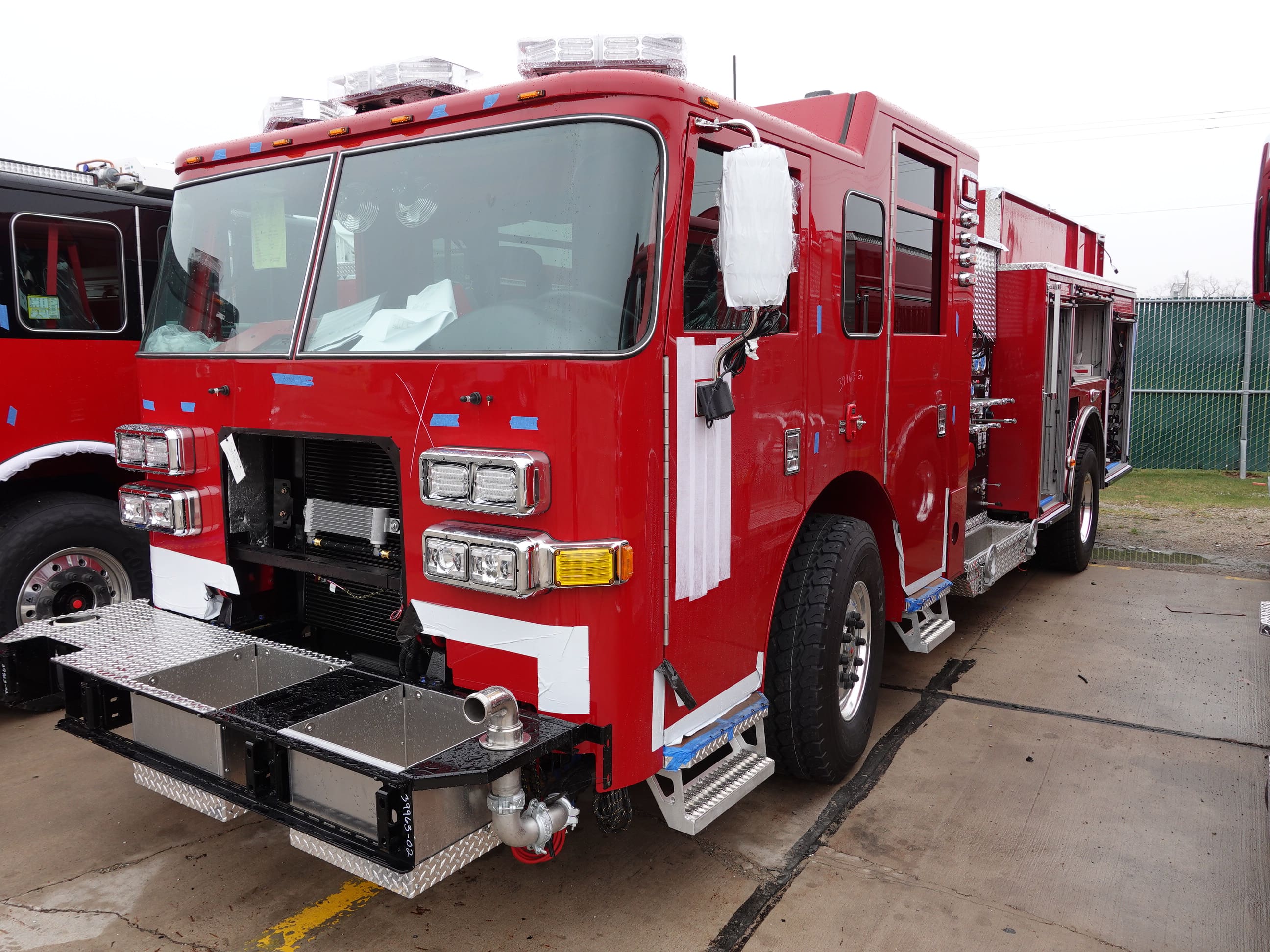

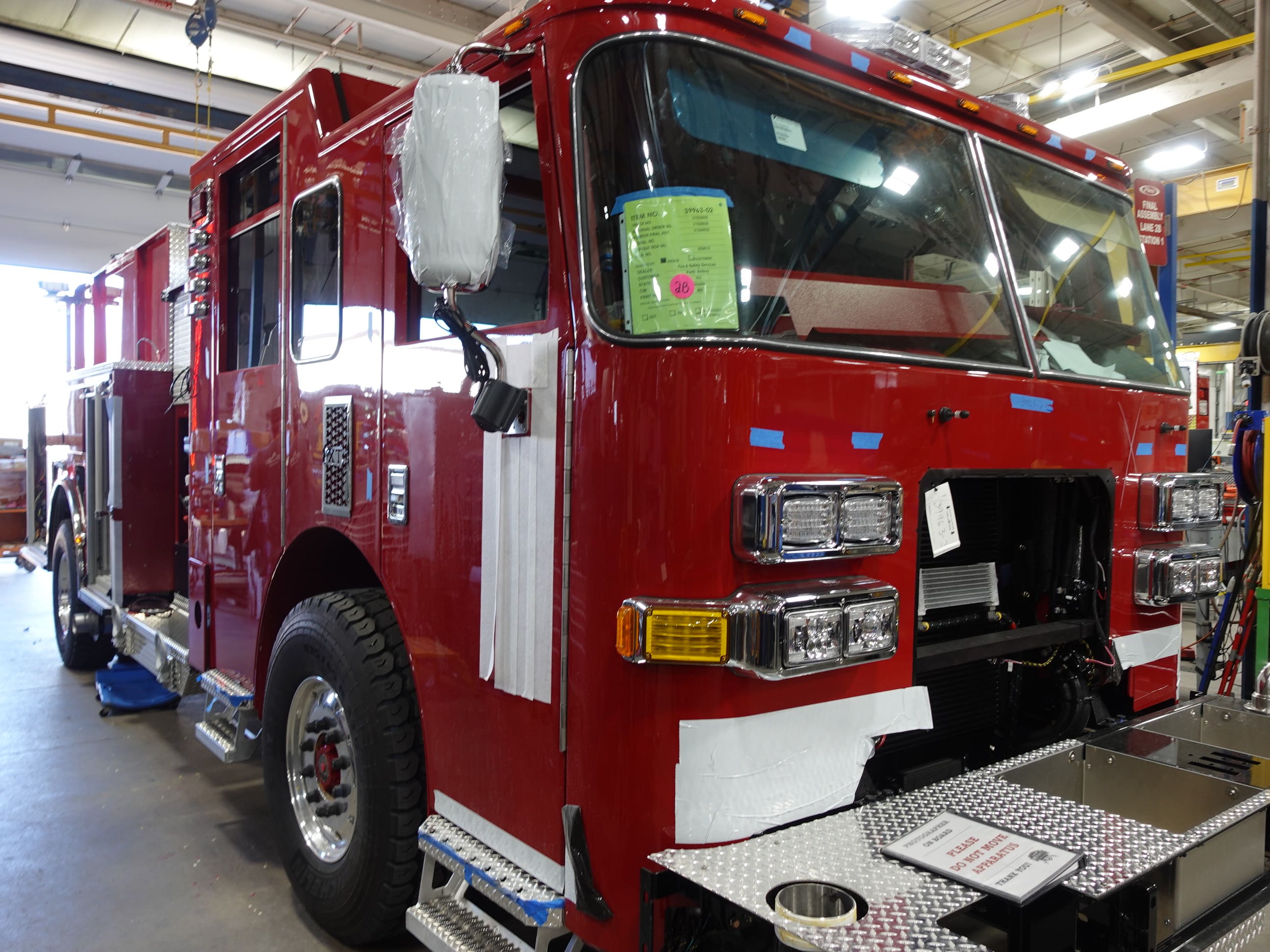

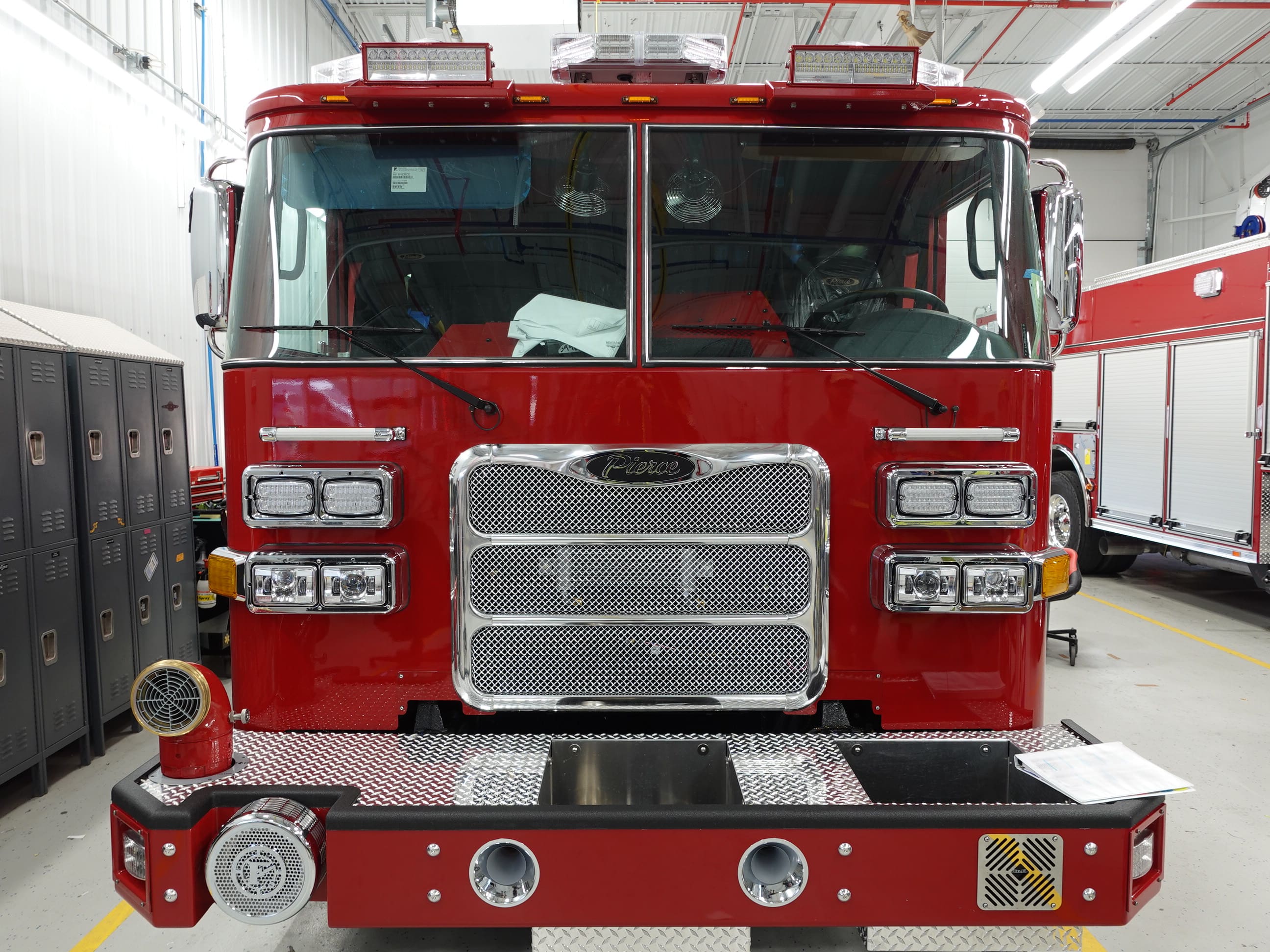

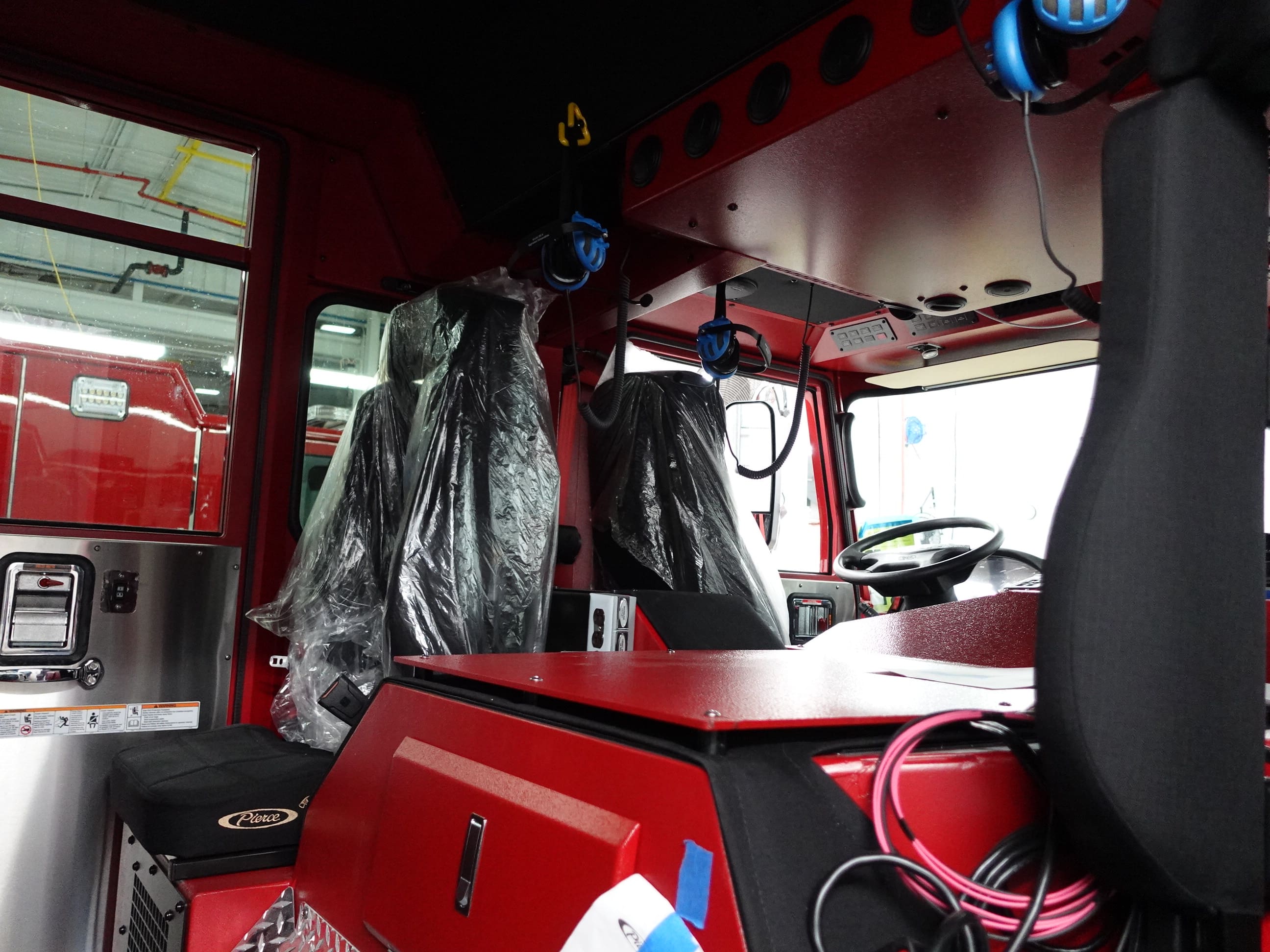

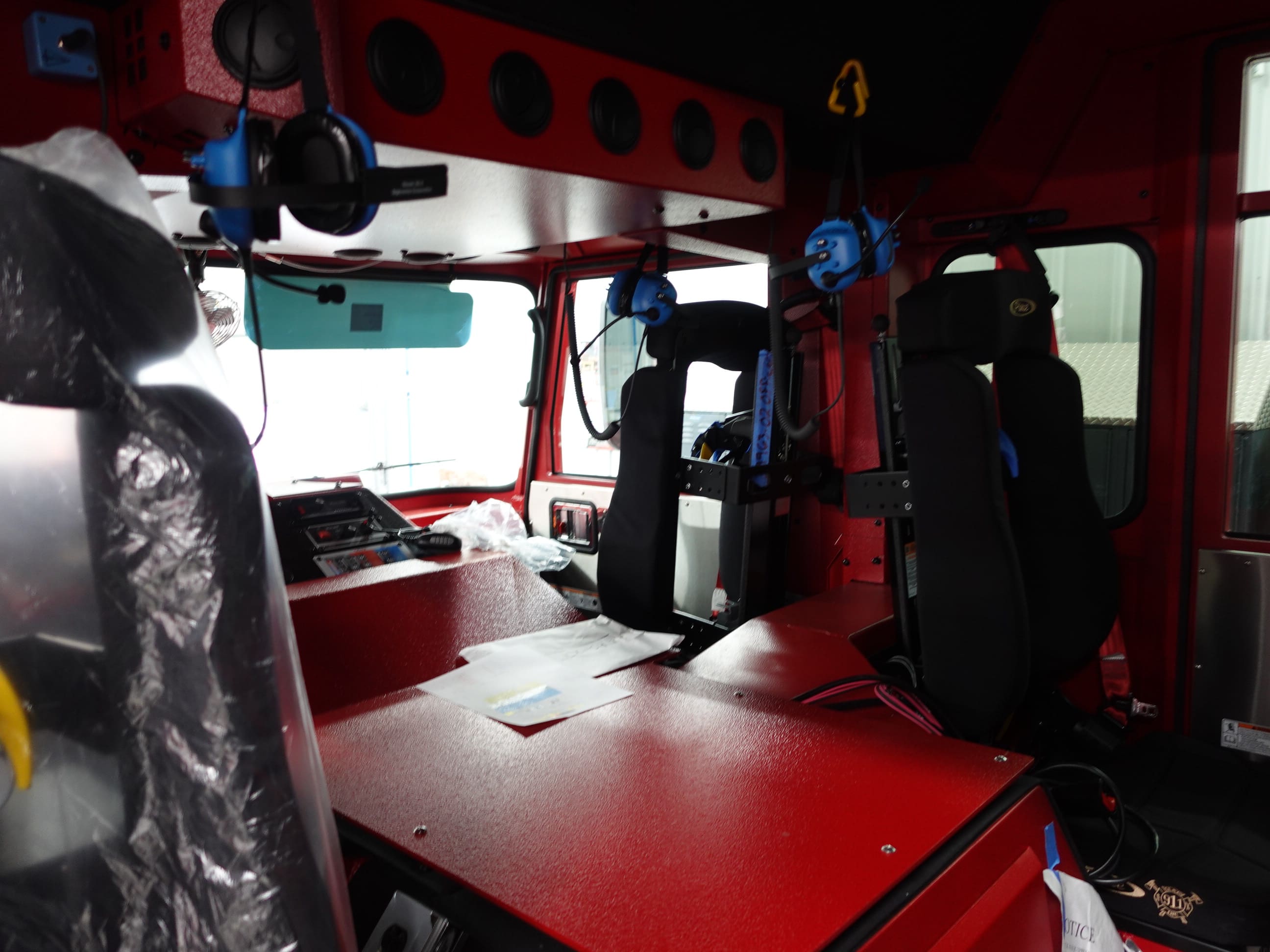

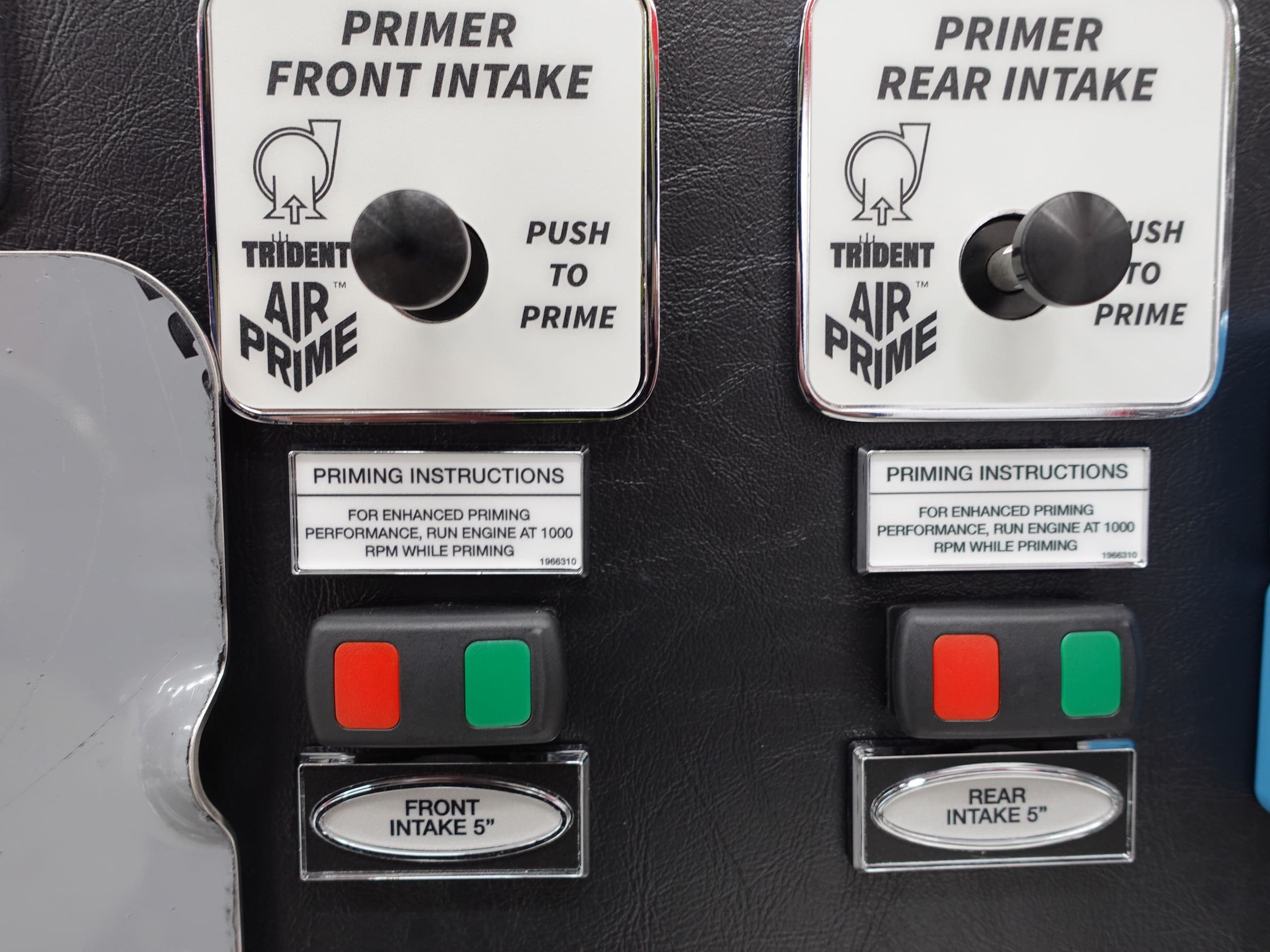

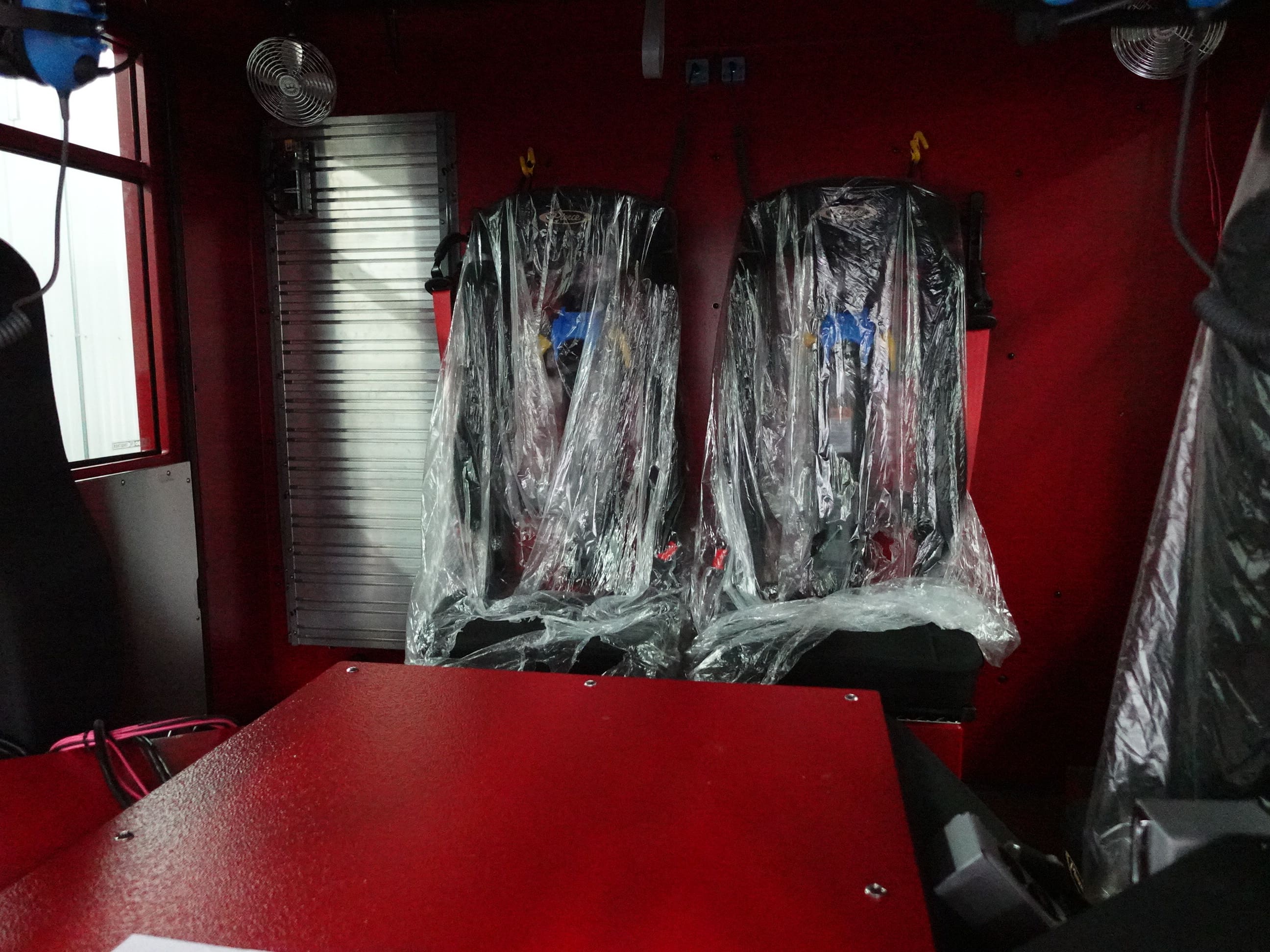

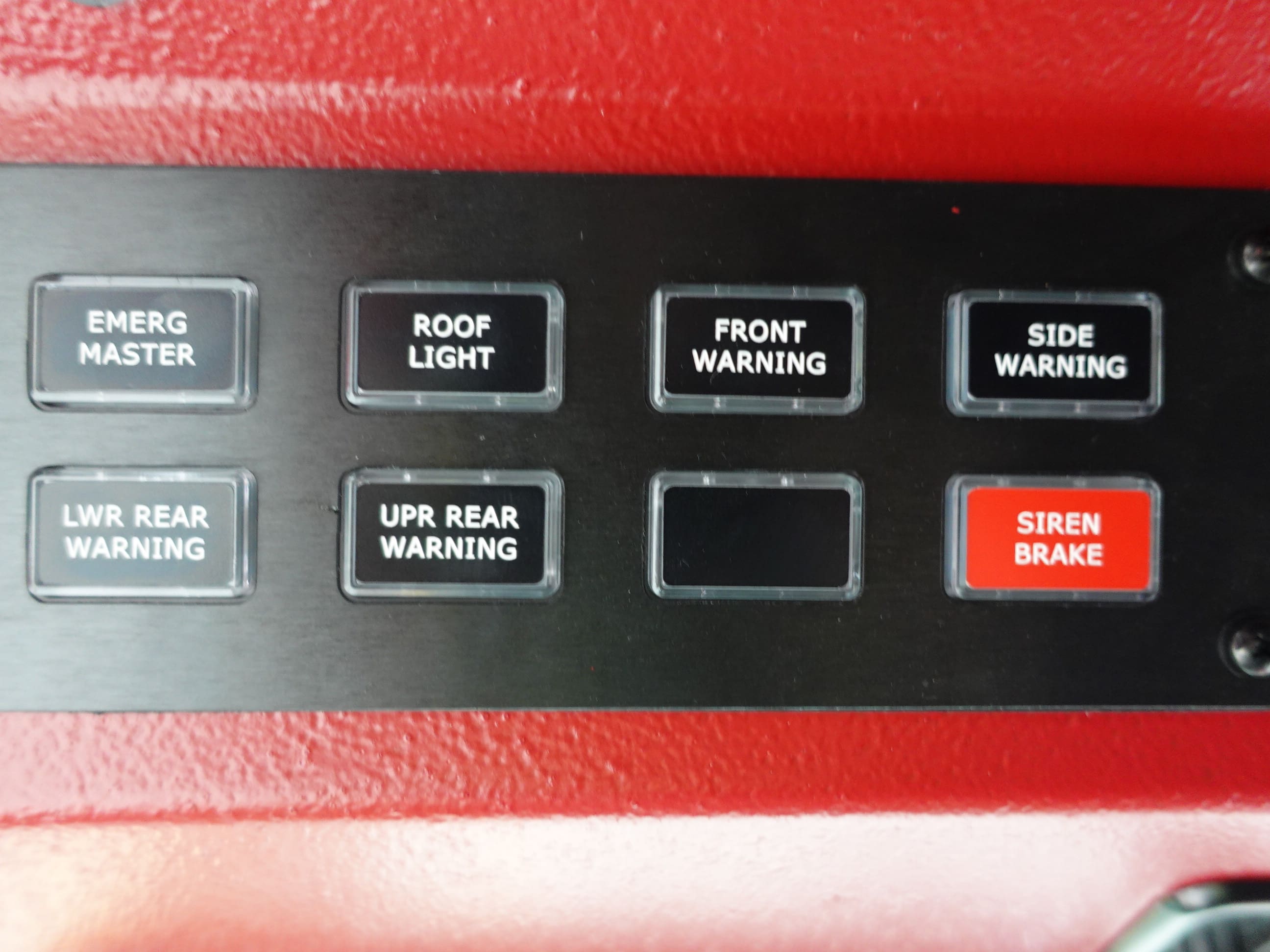

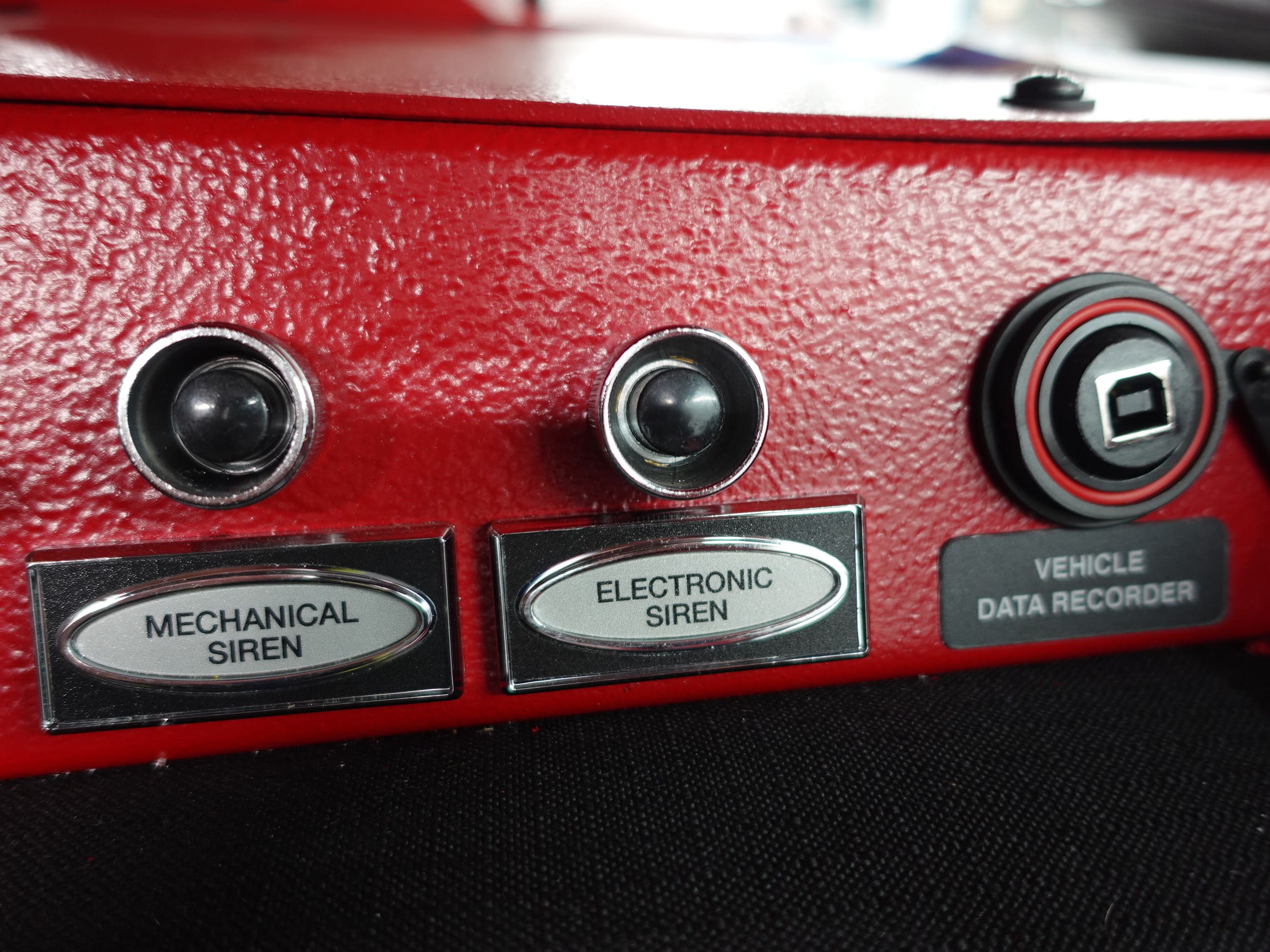

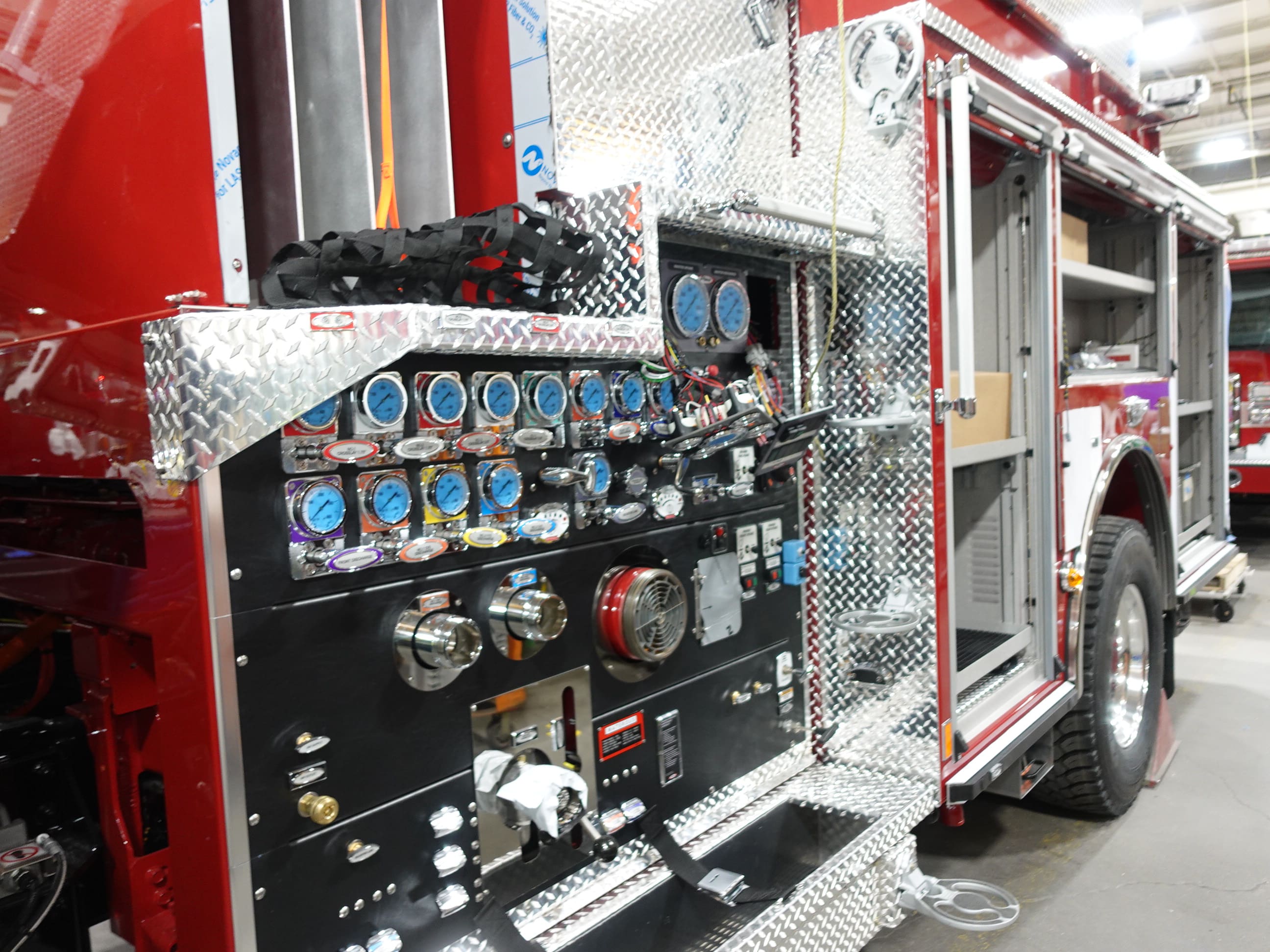

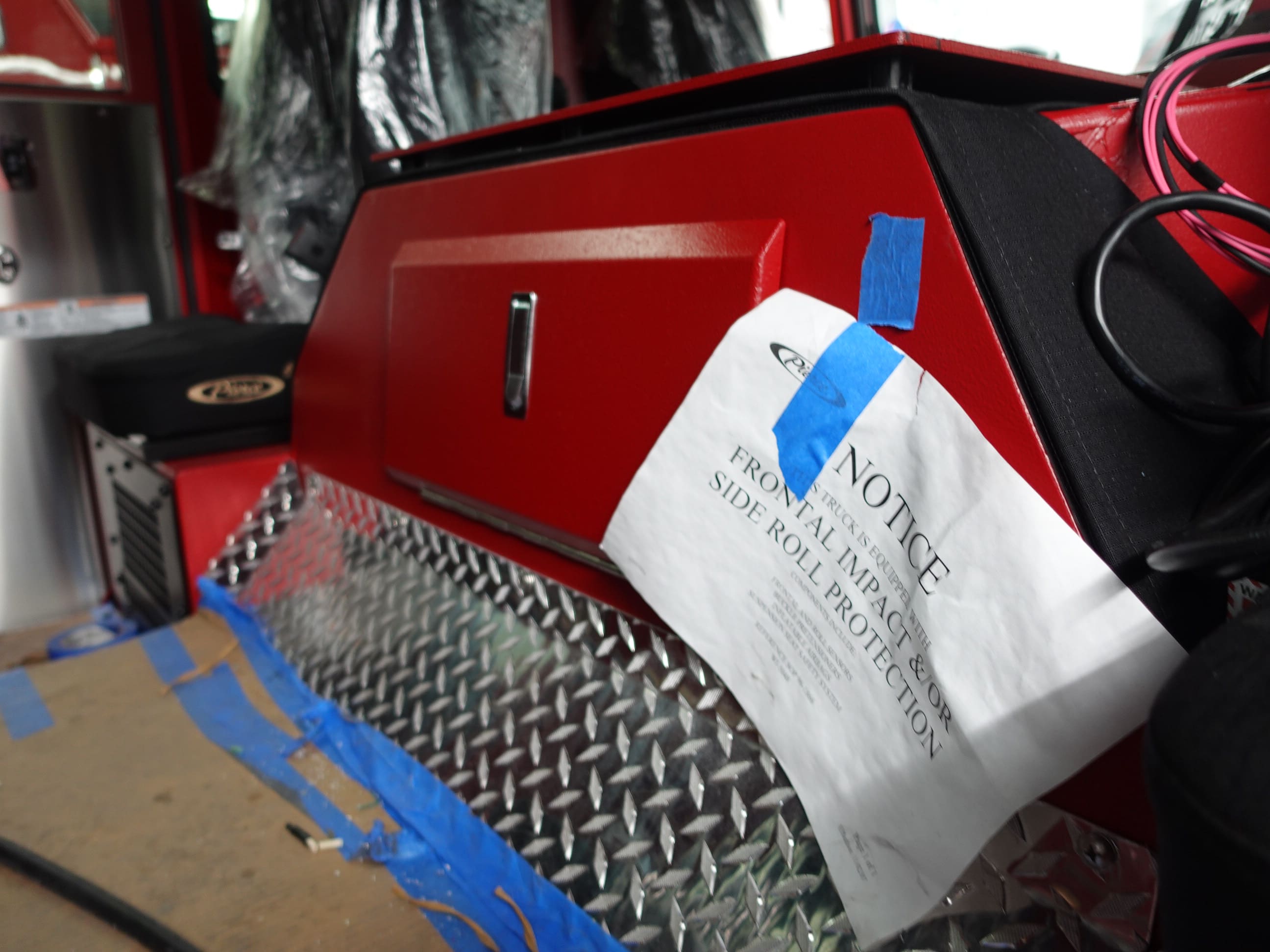

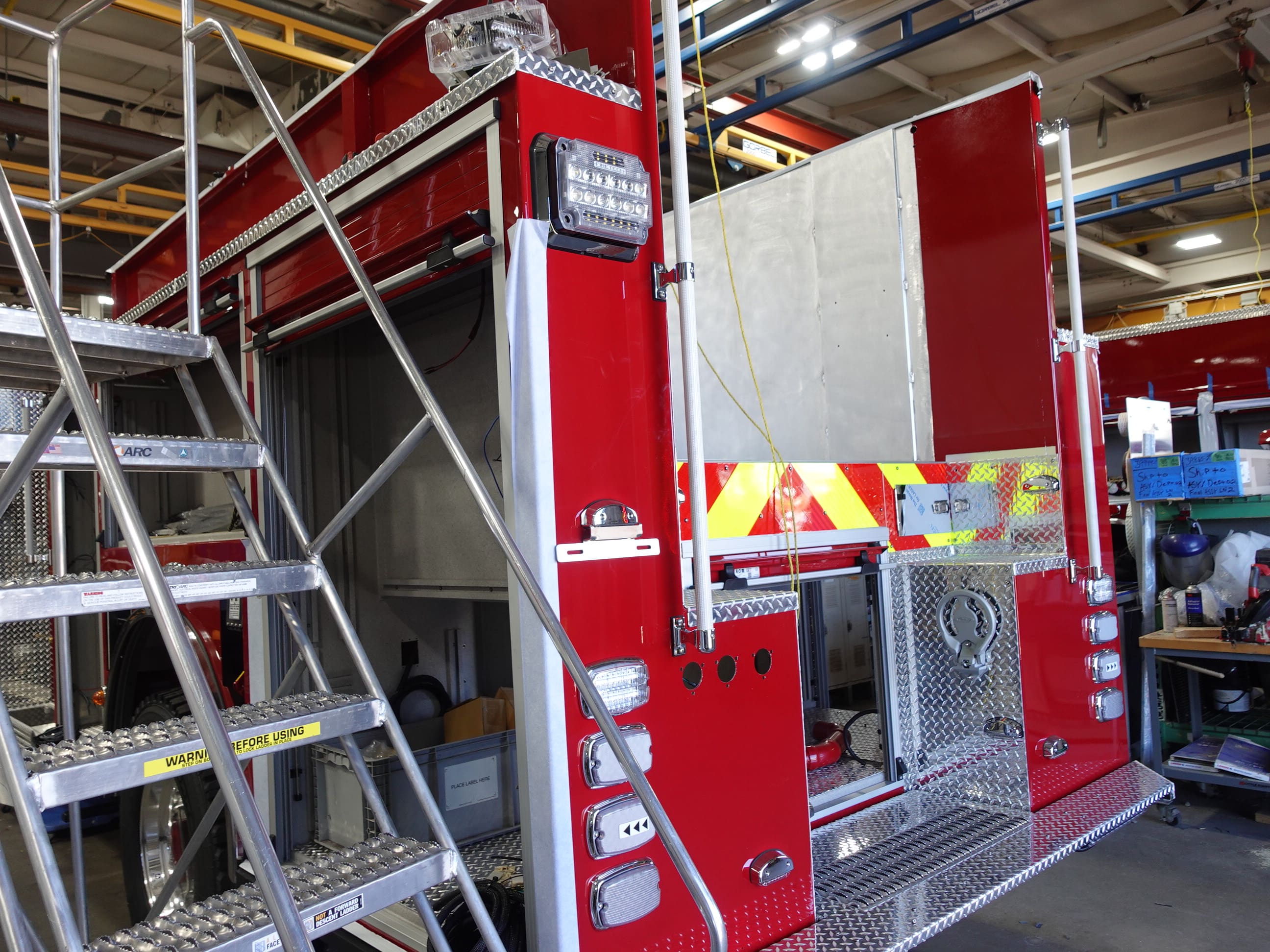

In this report, the apparatus completed testing then

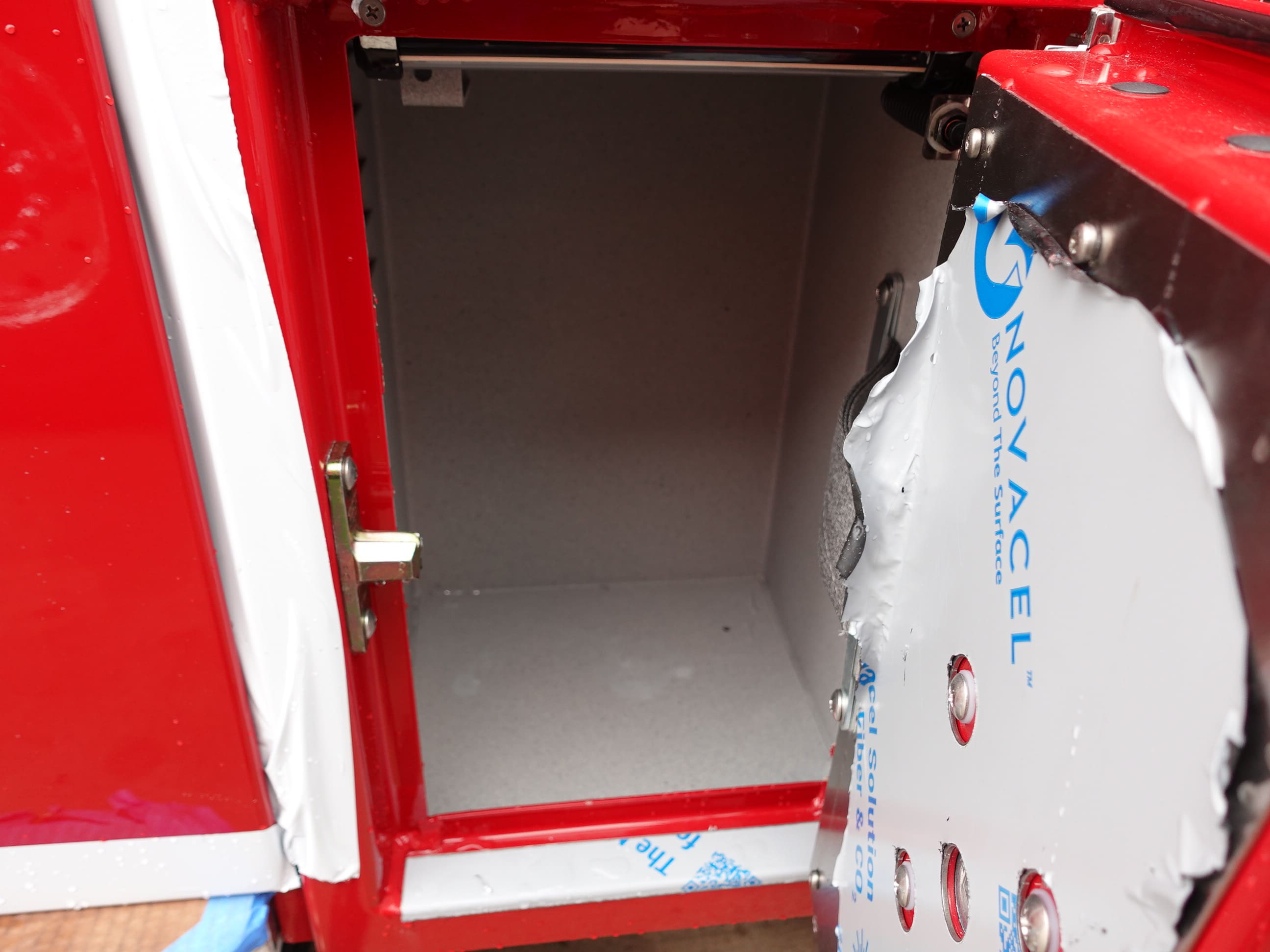

released to graphics and quality where any

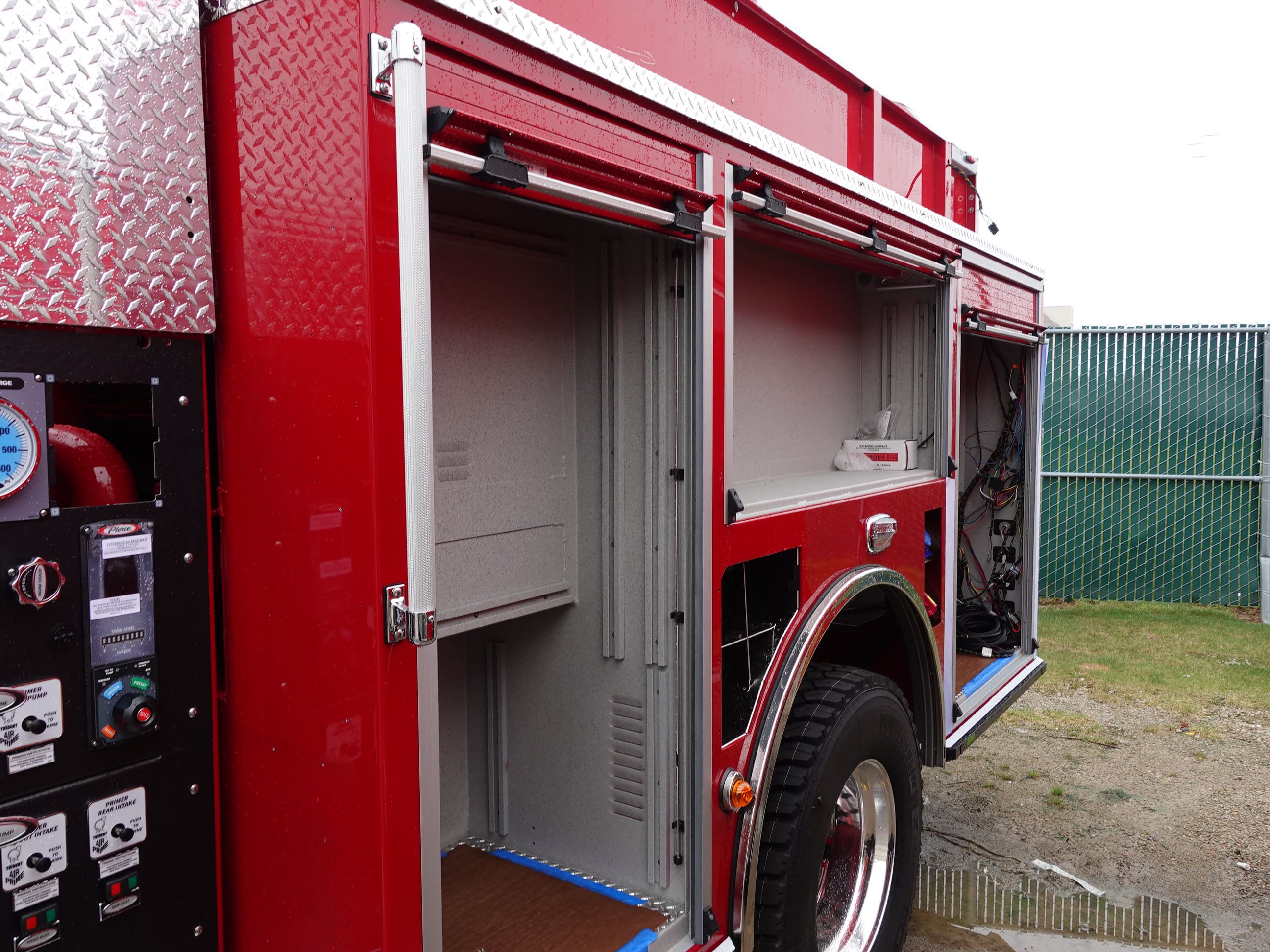

remaining content will be applied. When finished it
will be made ready for the customer acceptance
inspection. This is the last scheduled report.
04-17-26

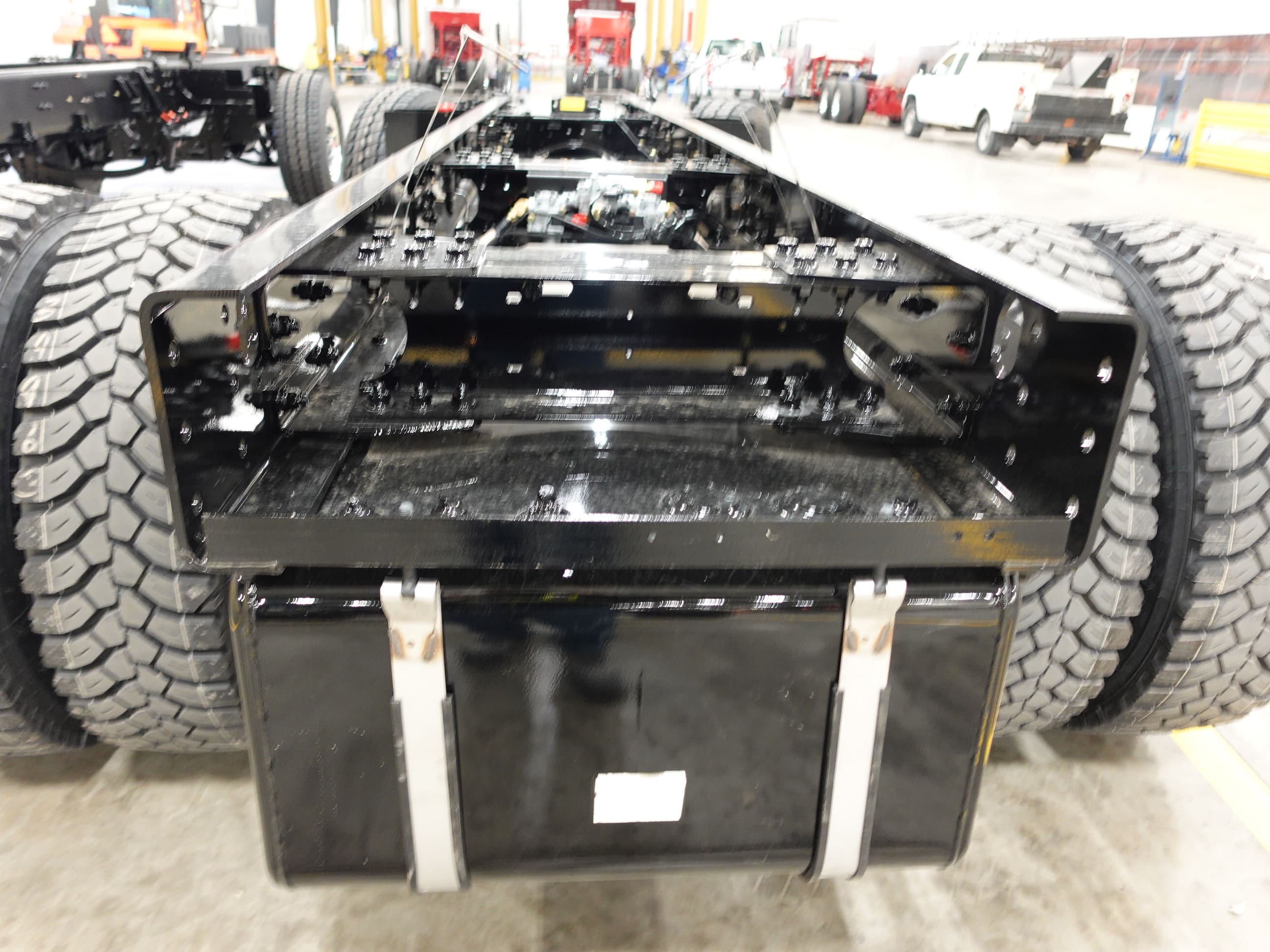

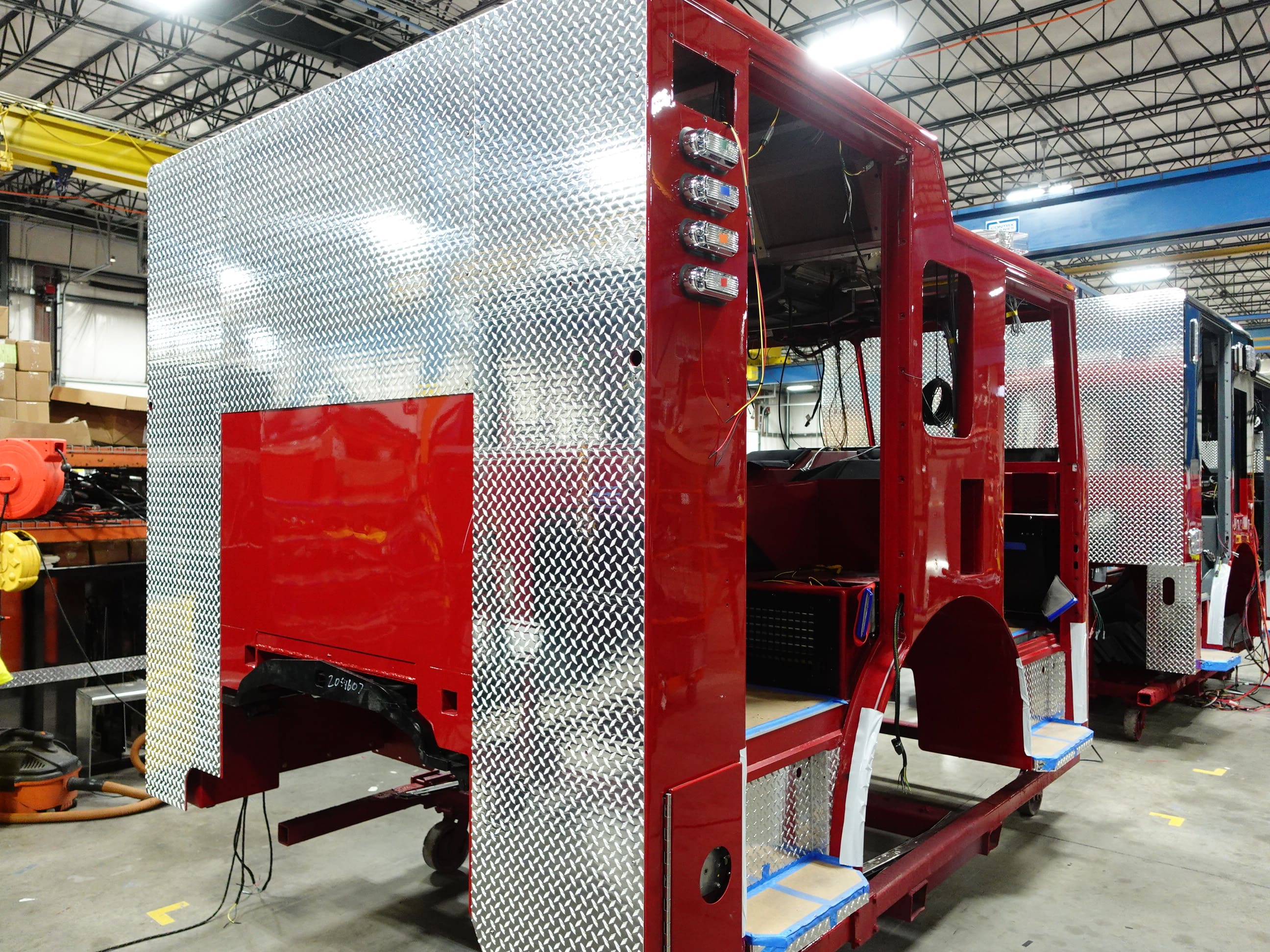

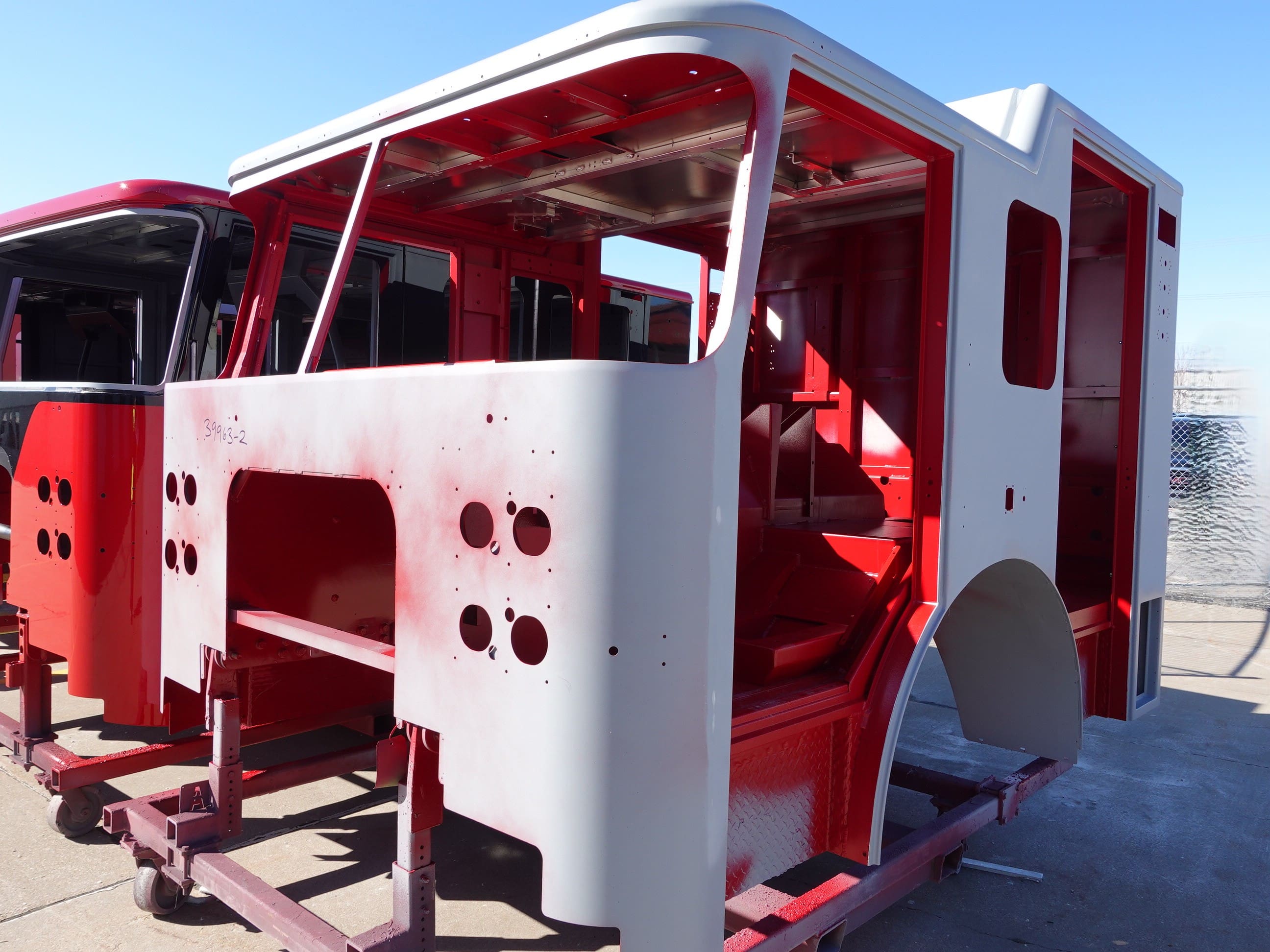

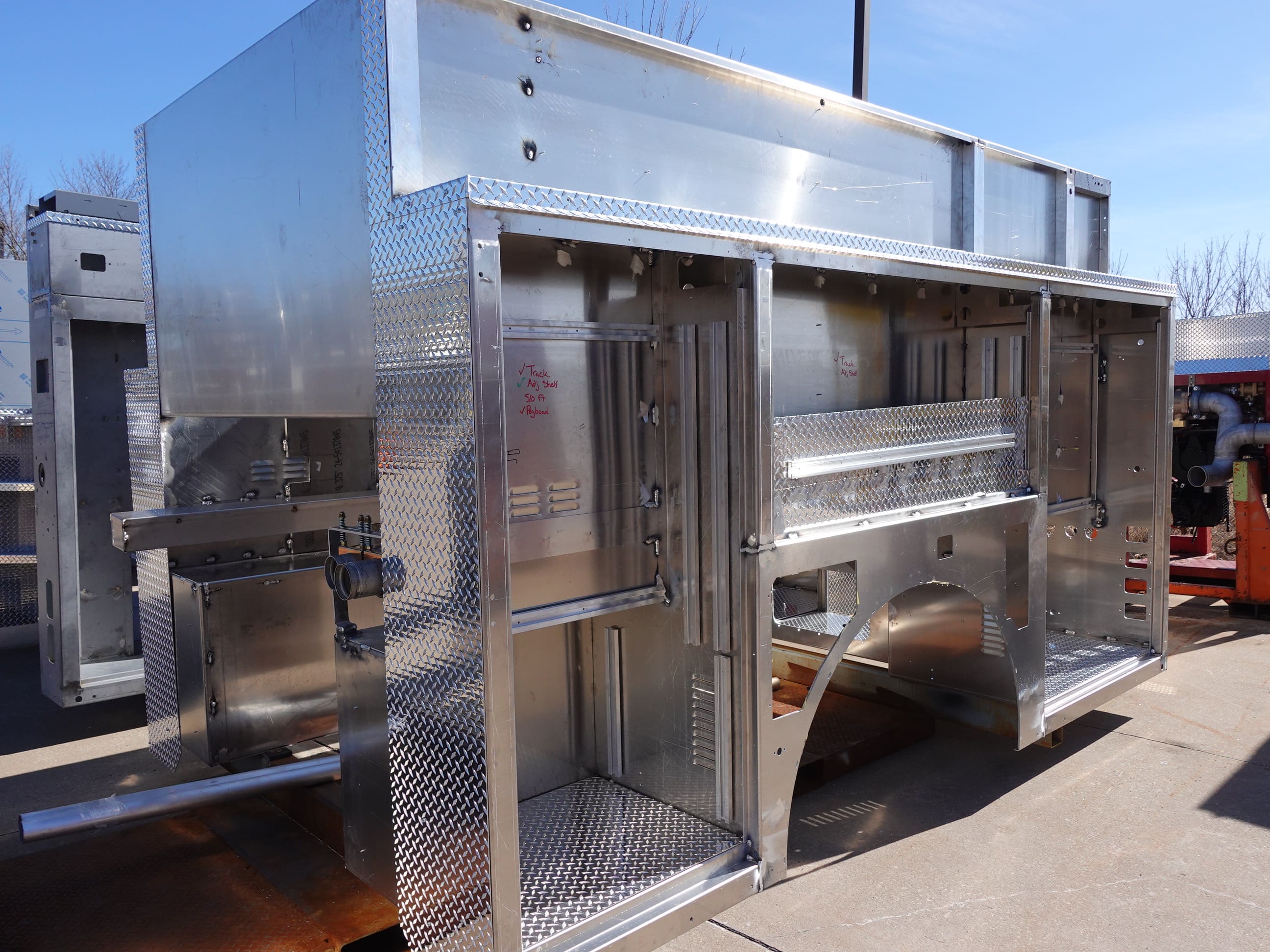

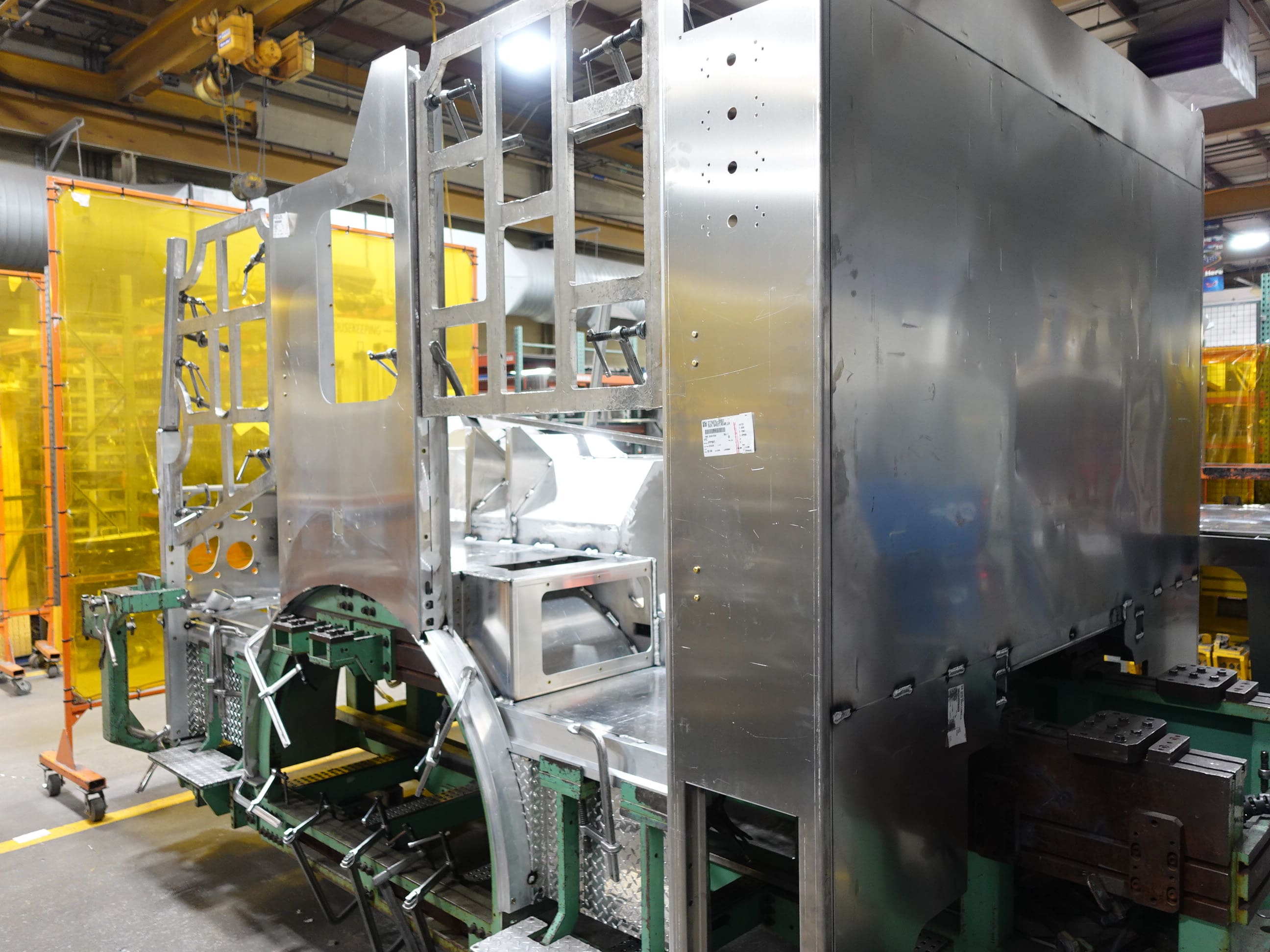

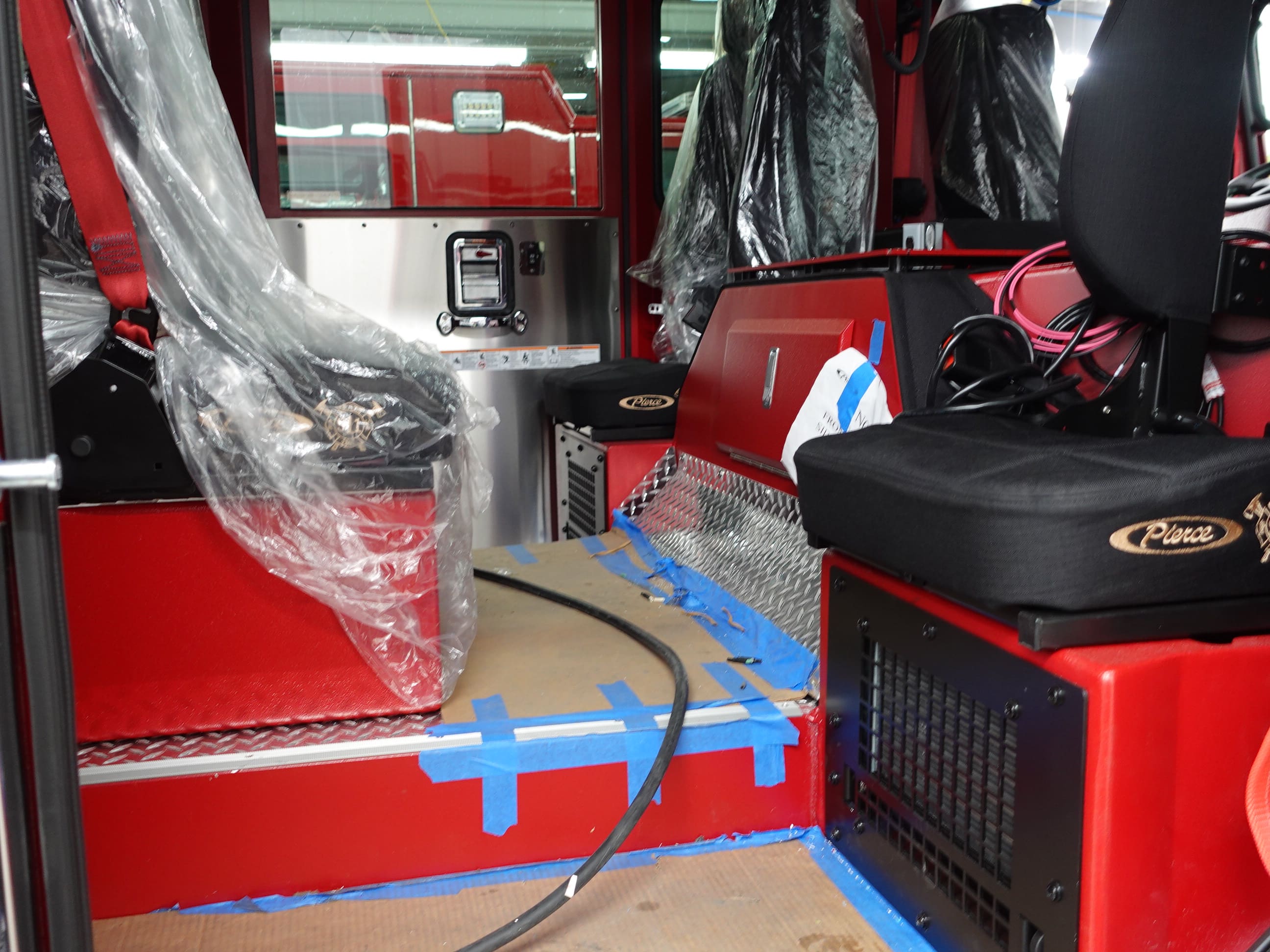

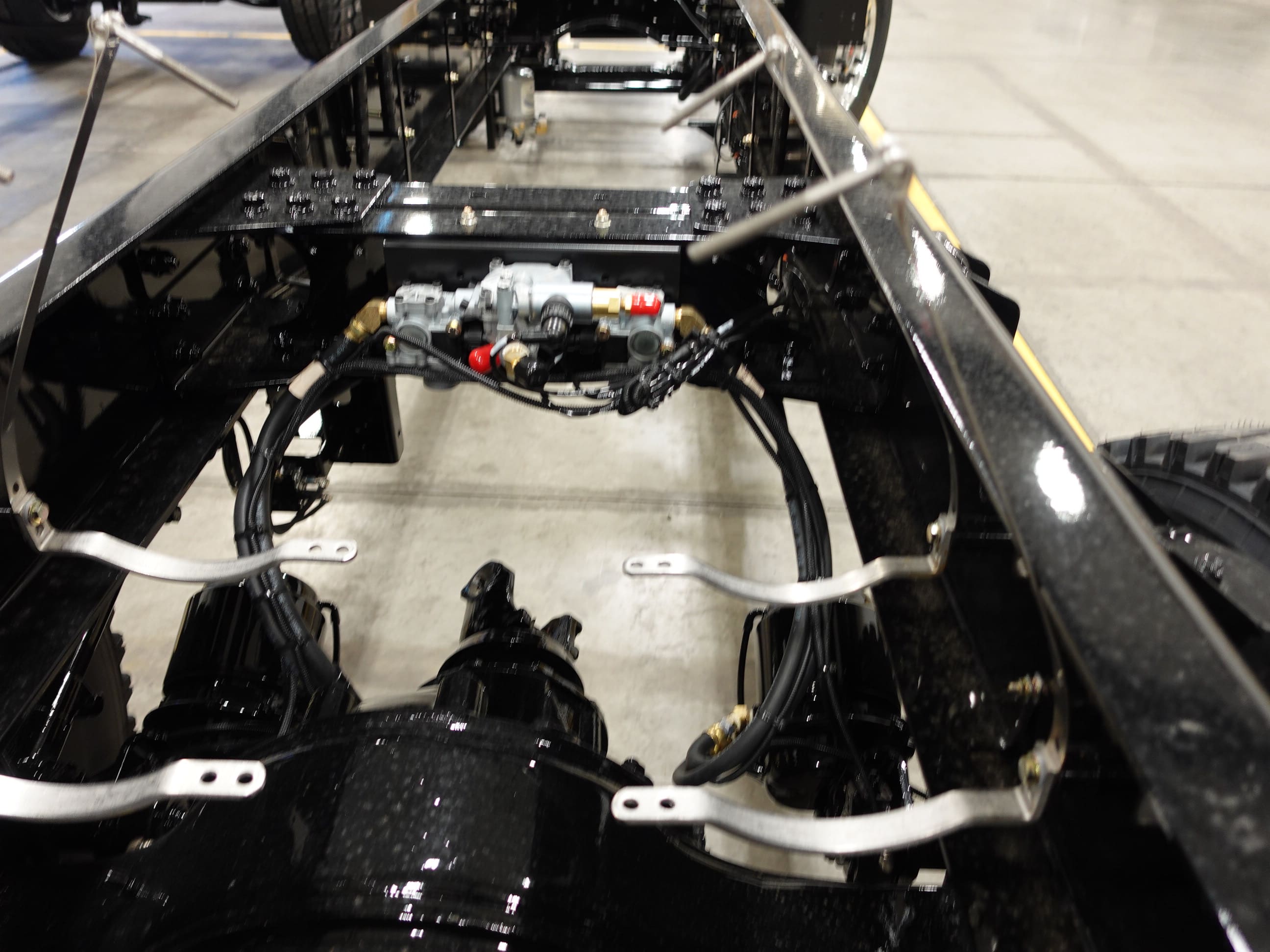

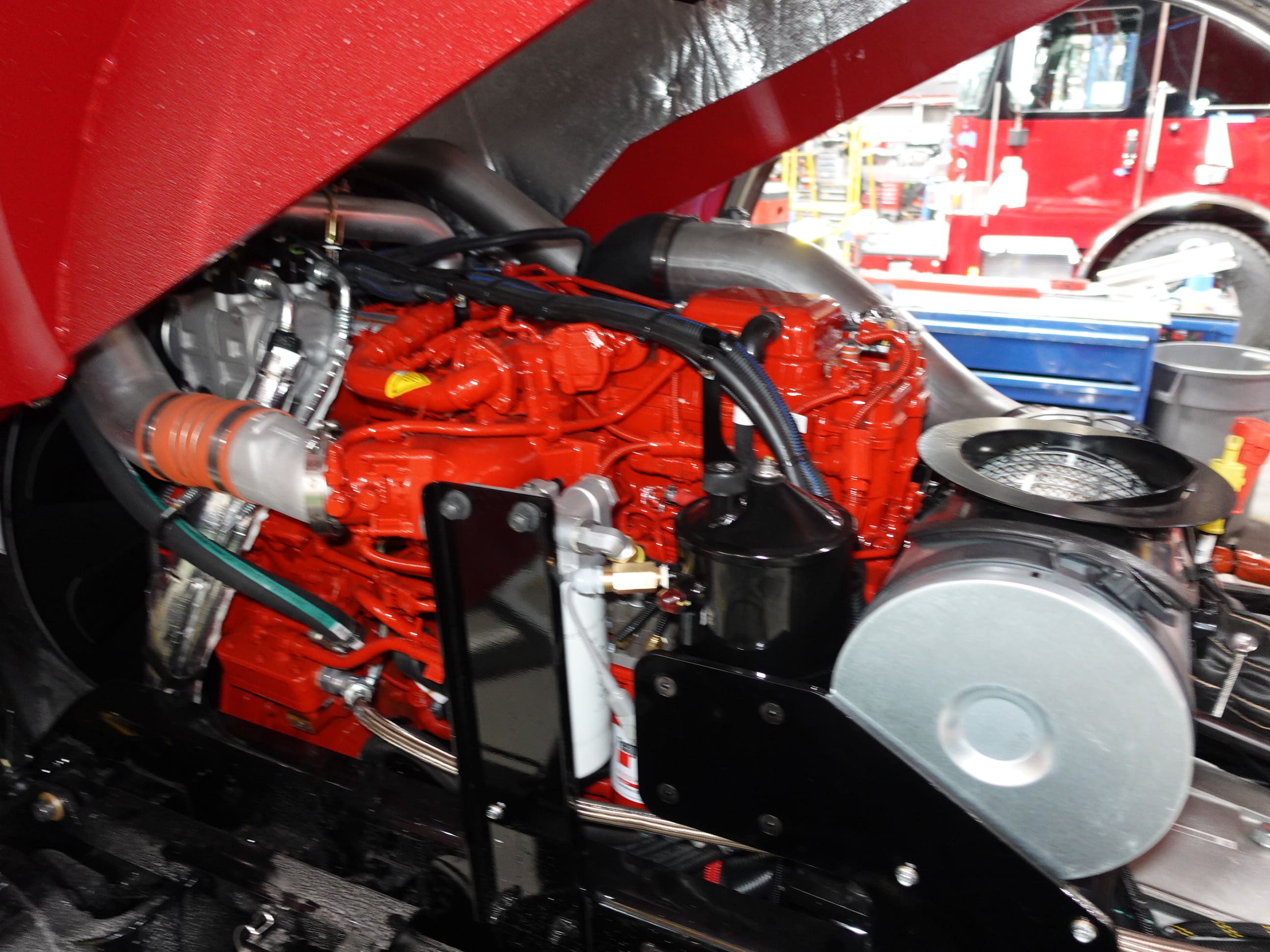

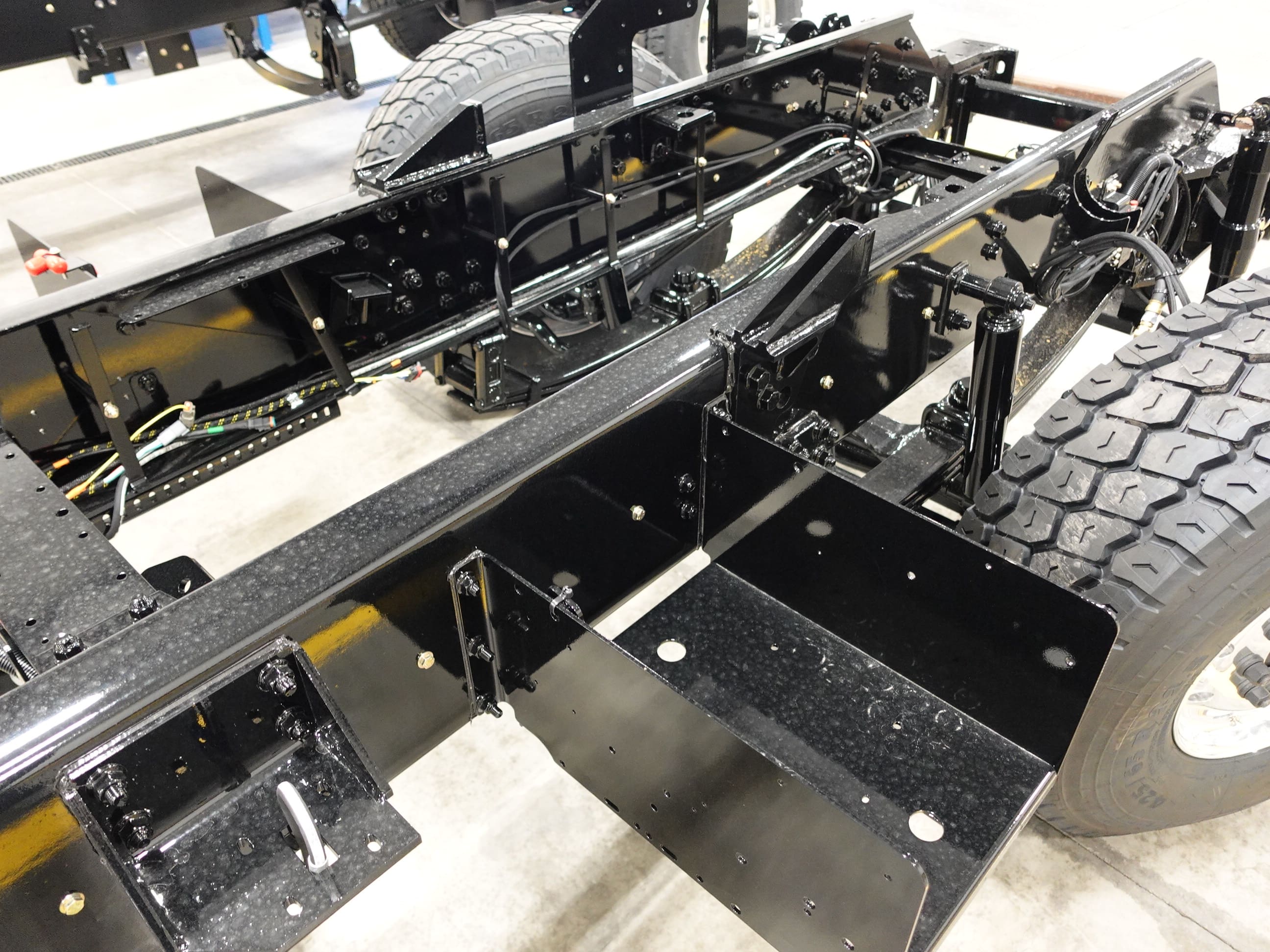

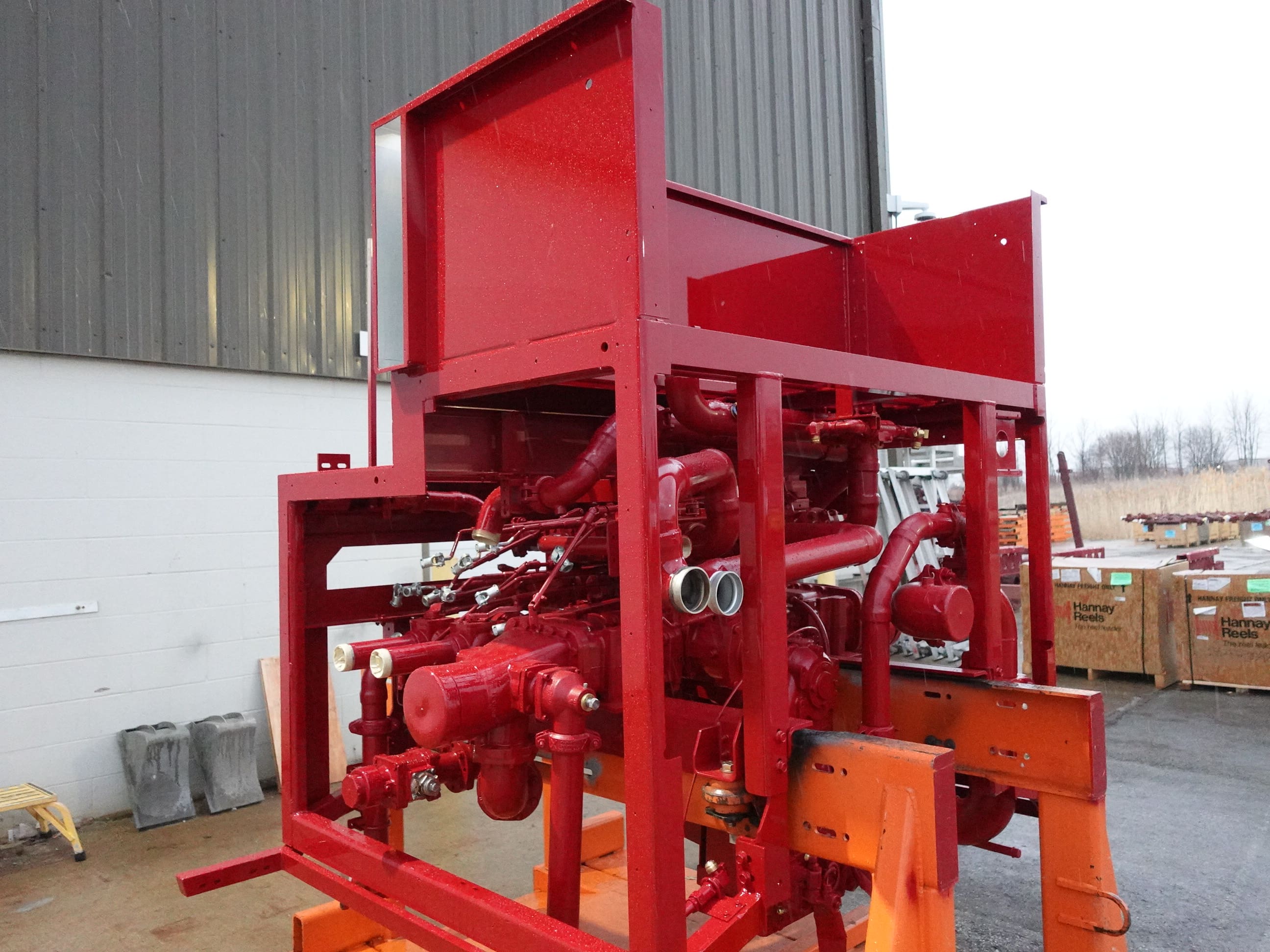

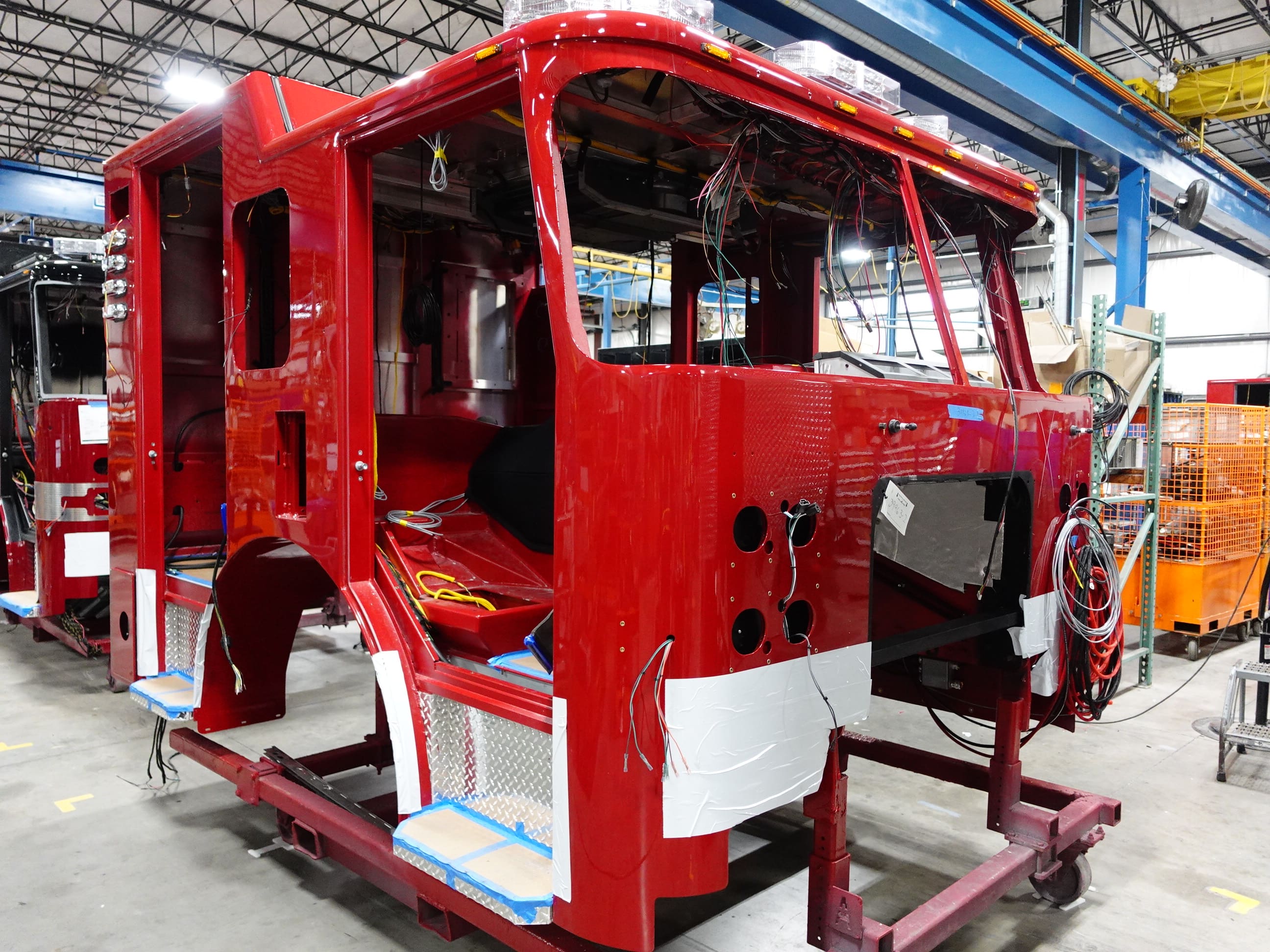

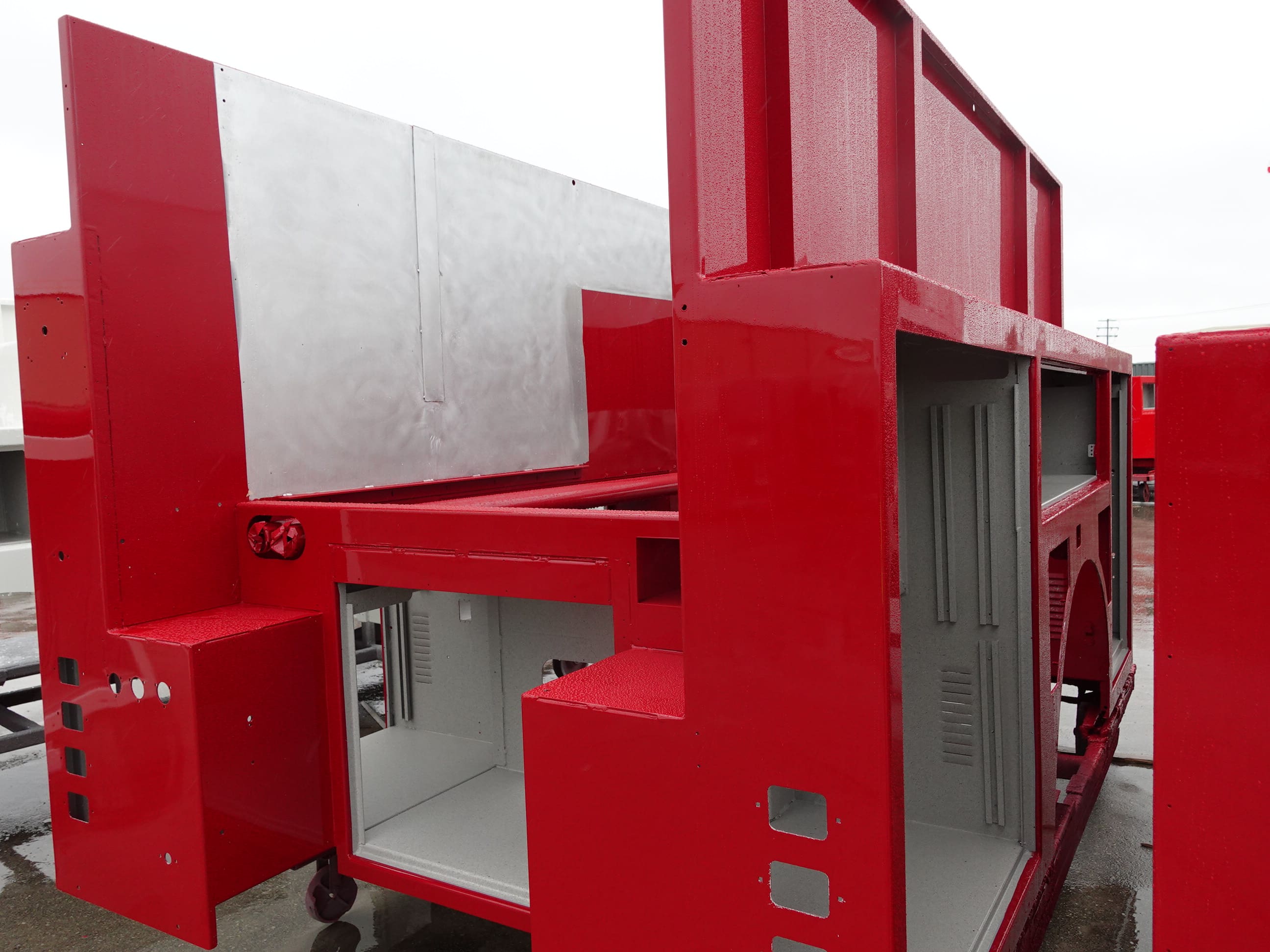

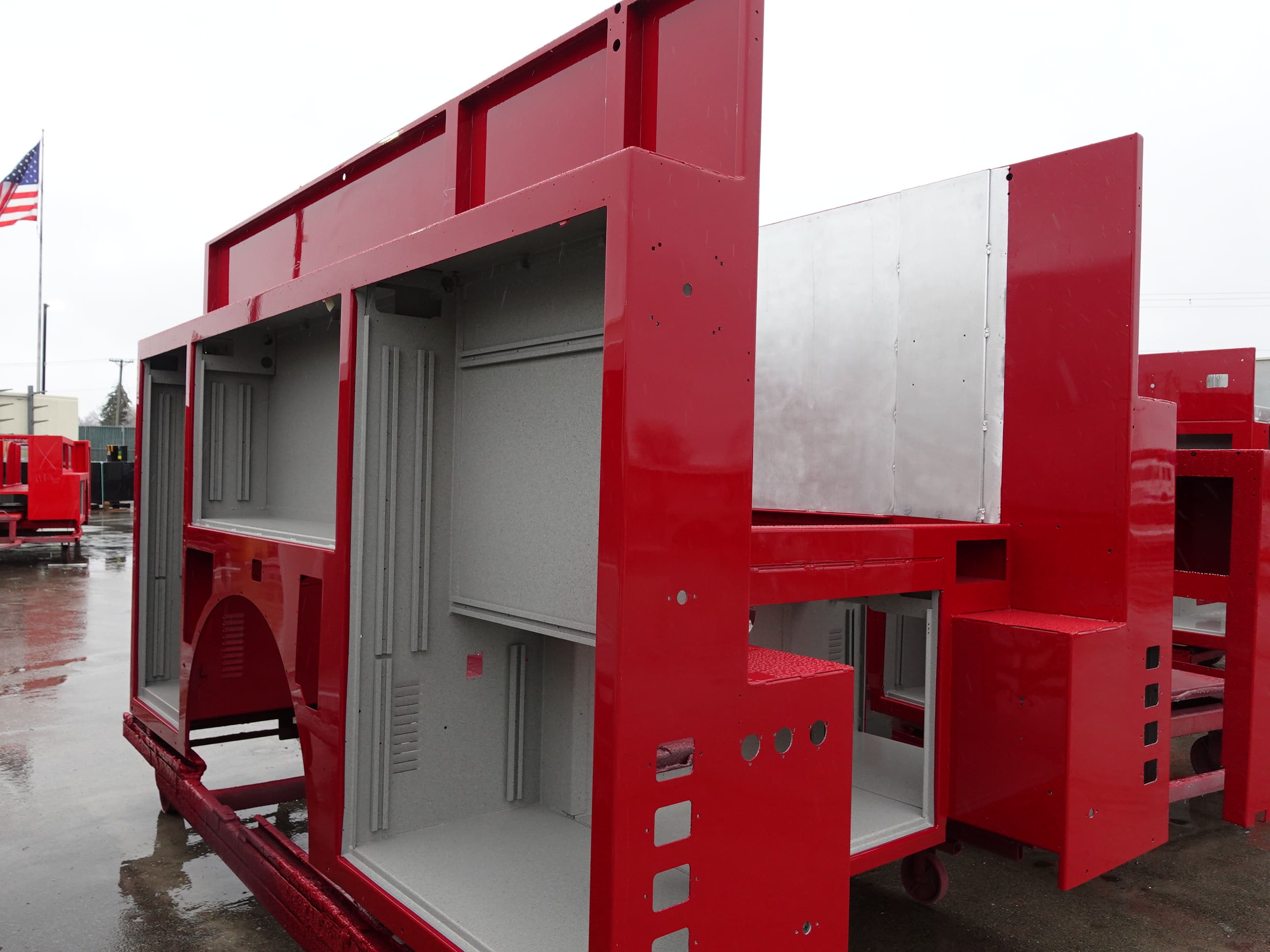

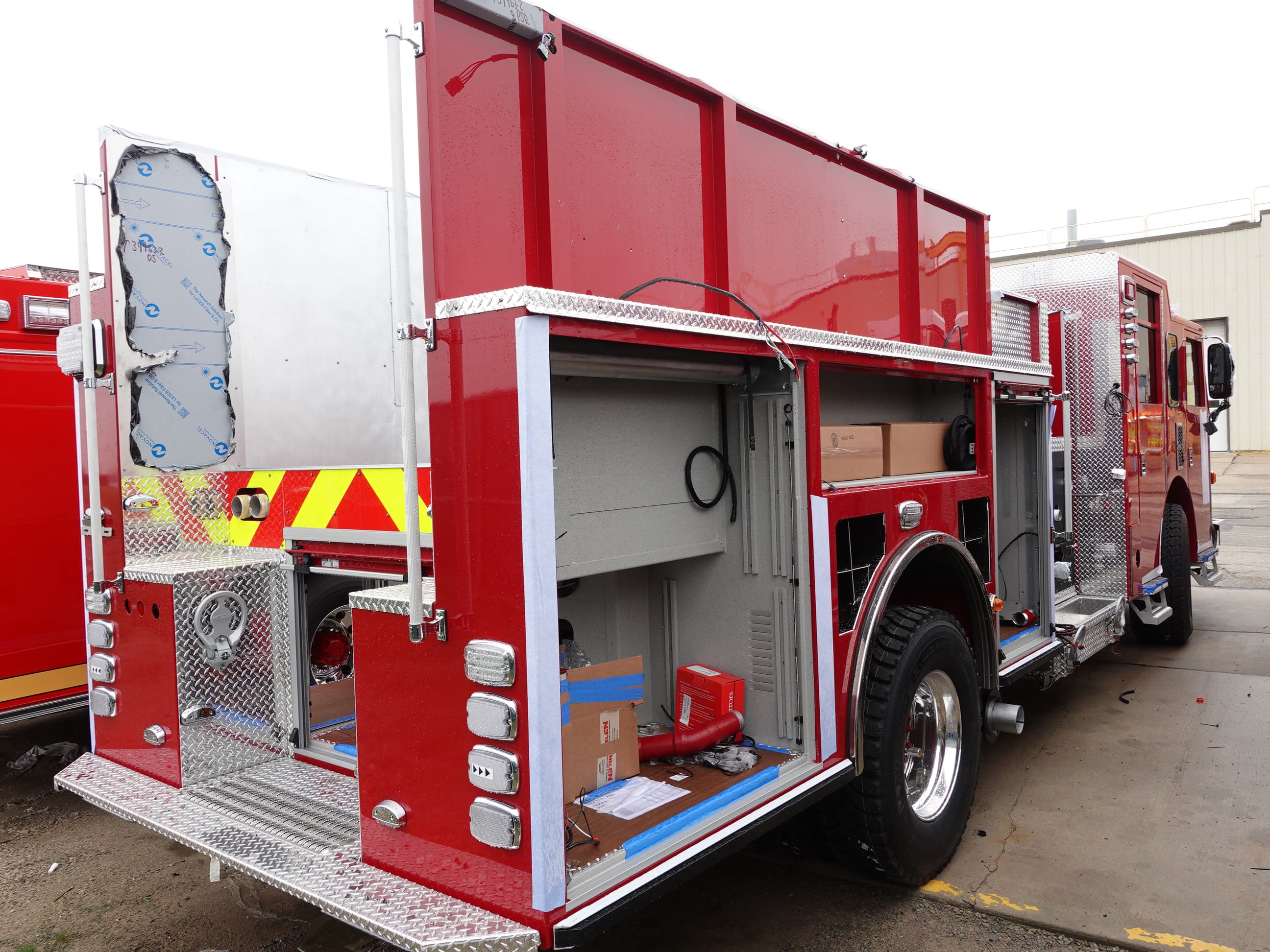

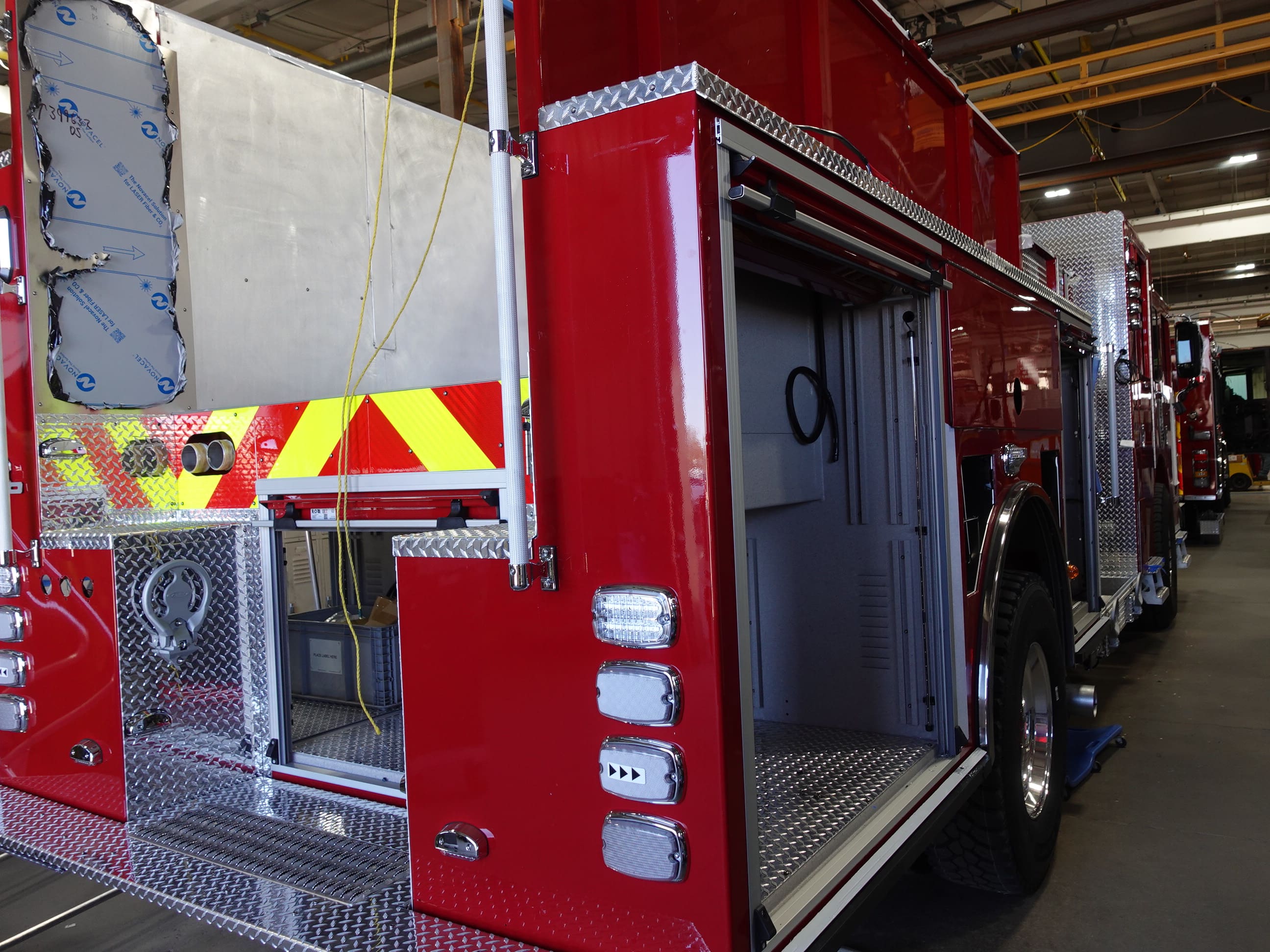

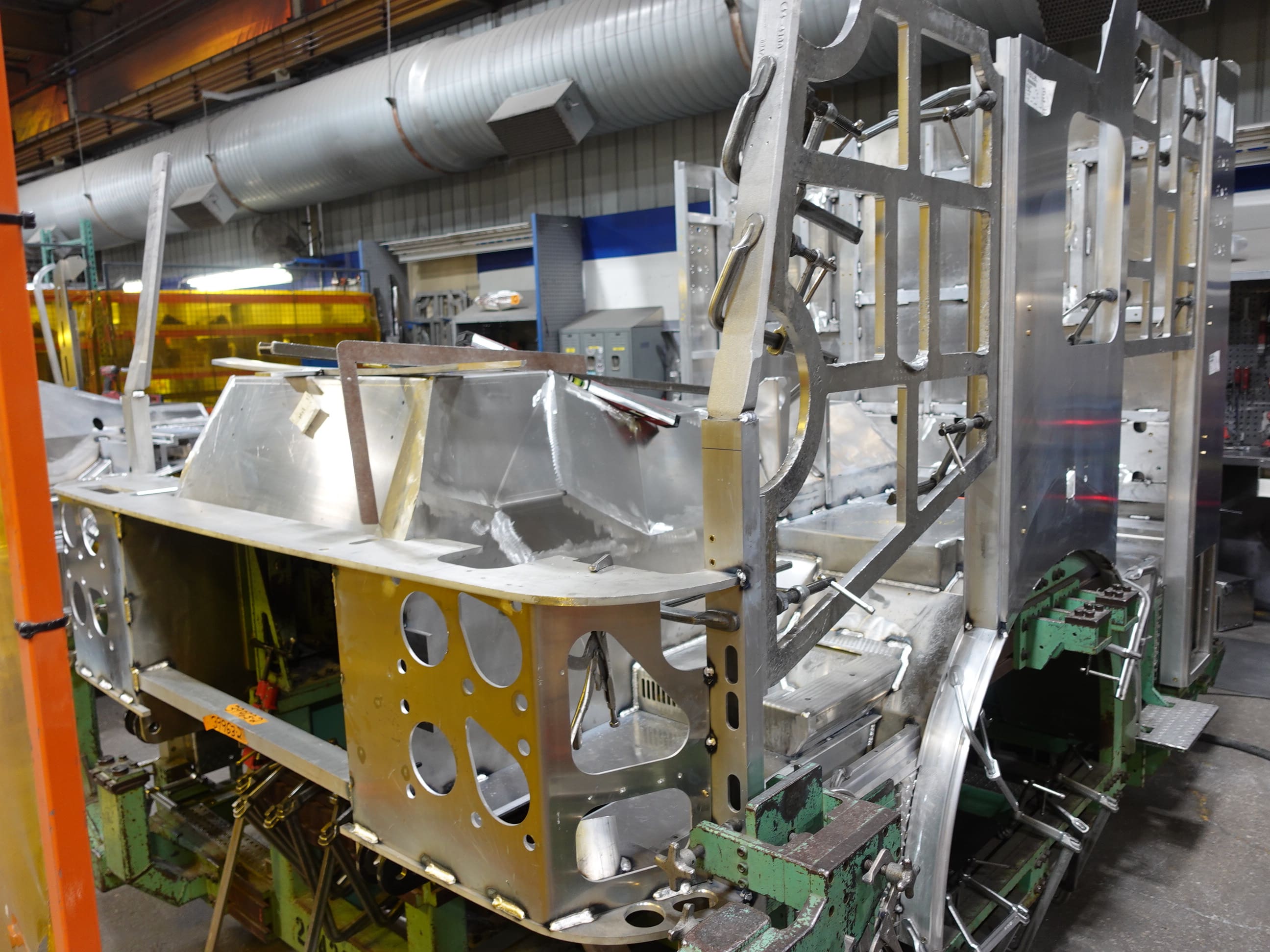

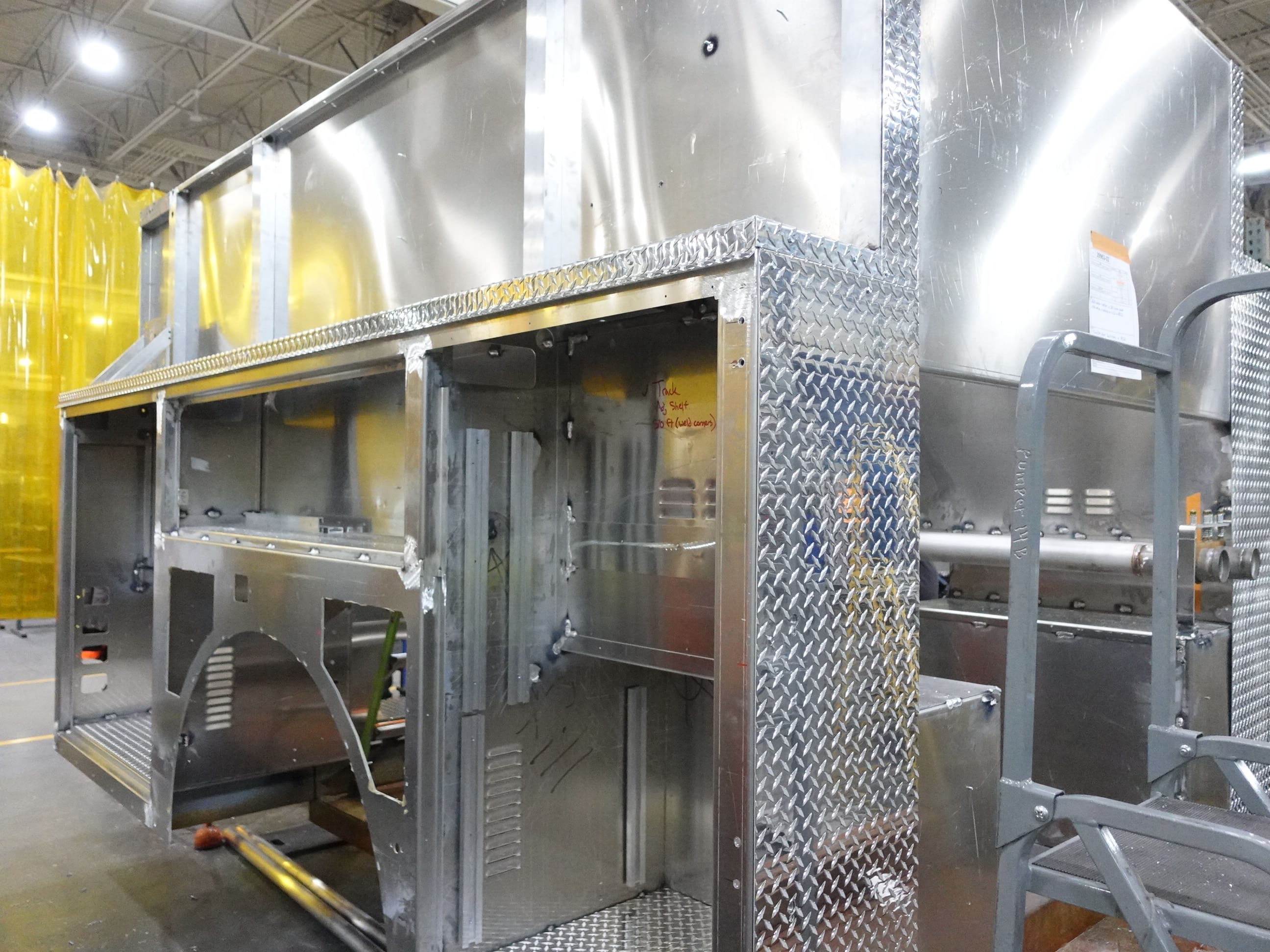

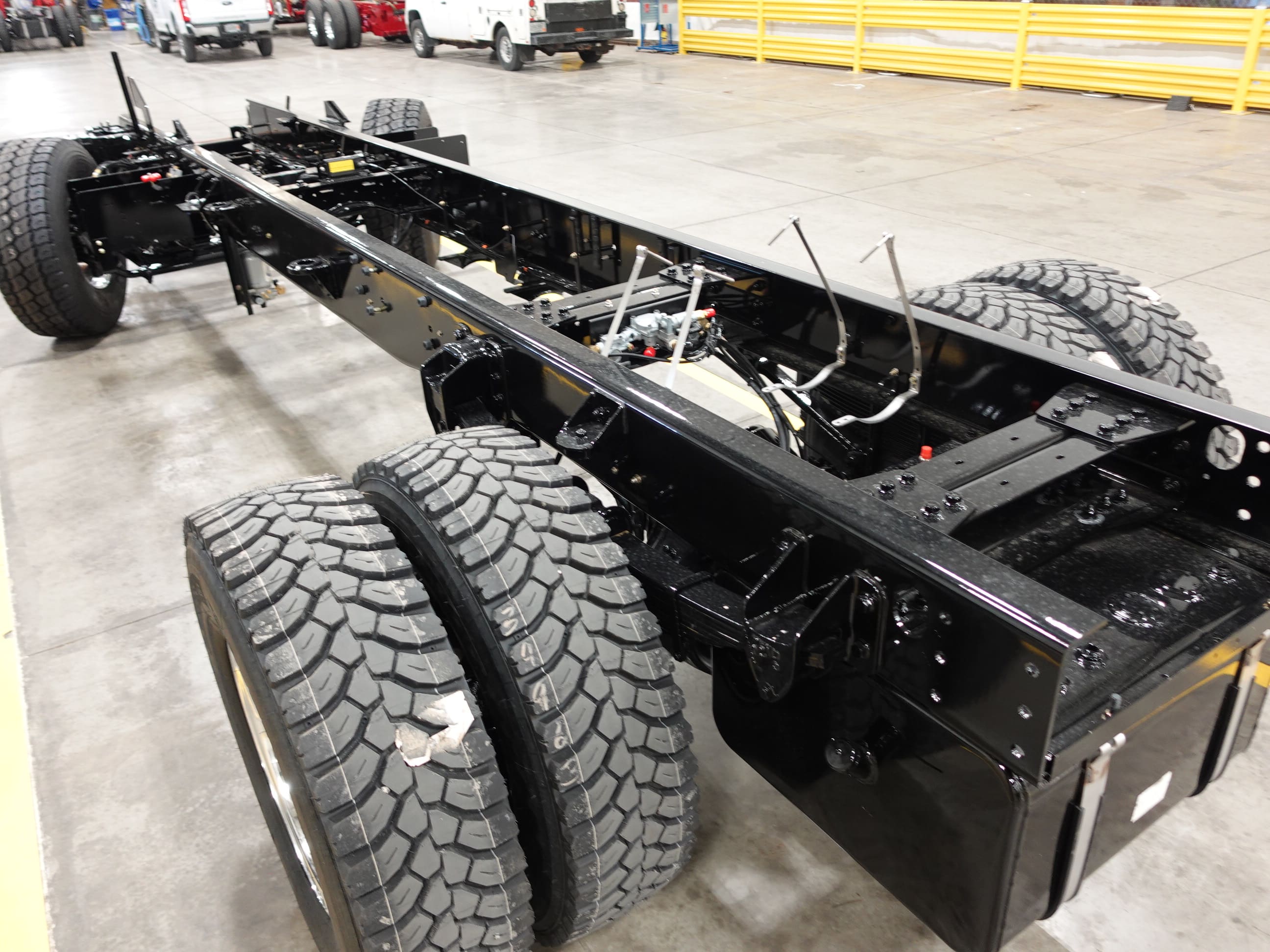

In this report, the cab and pump house were merged with the frame followed by body installation then the completion of initial apparatus assembly.

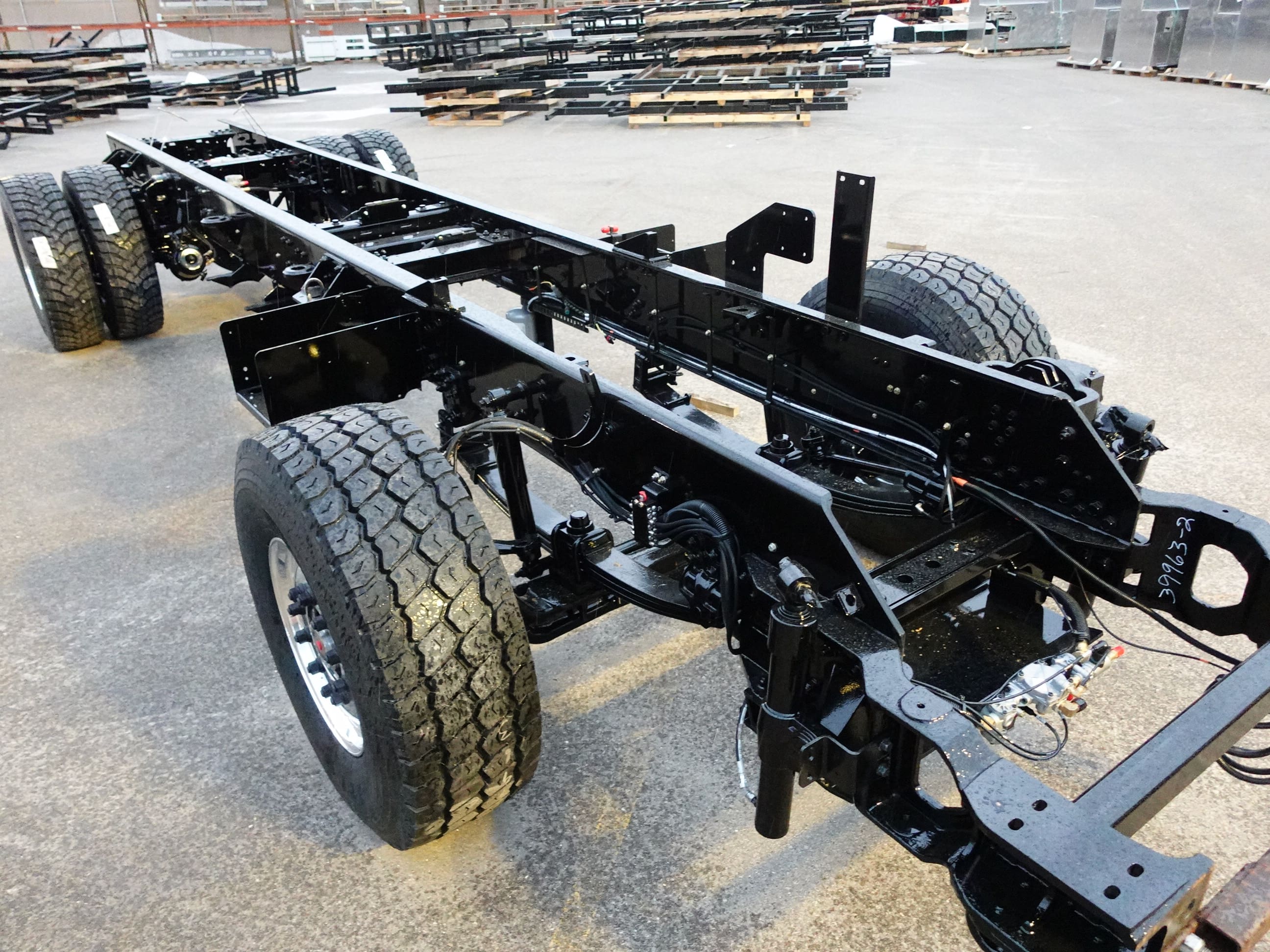

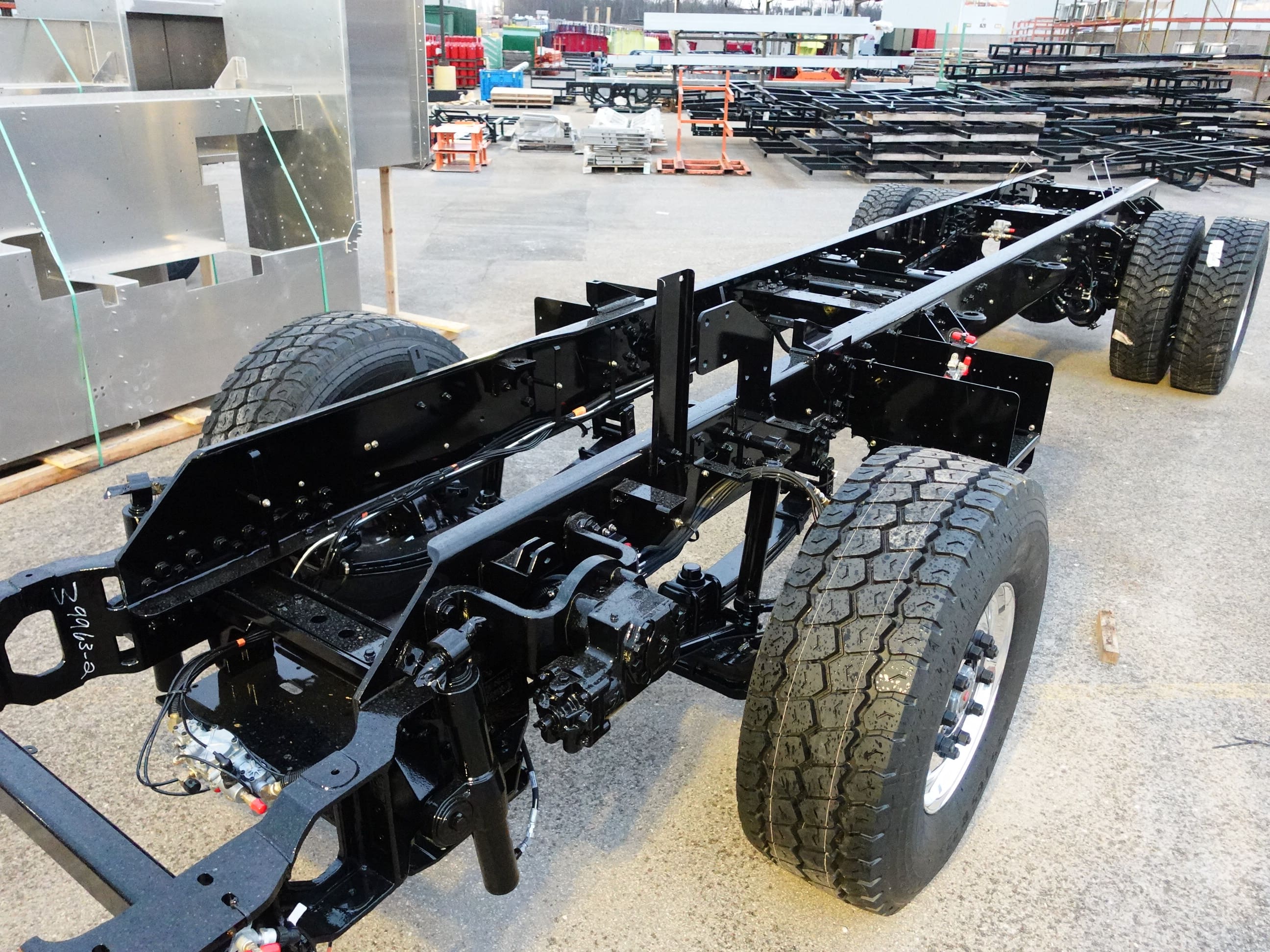

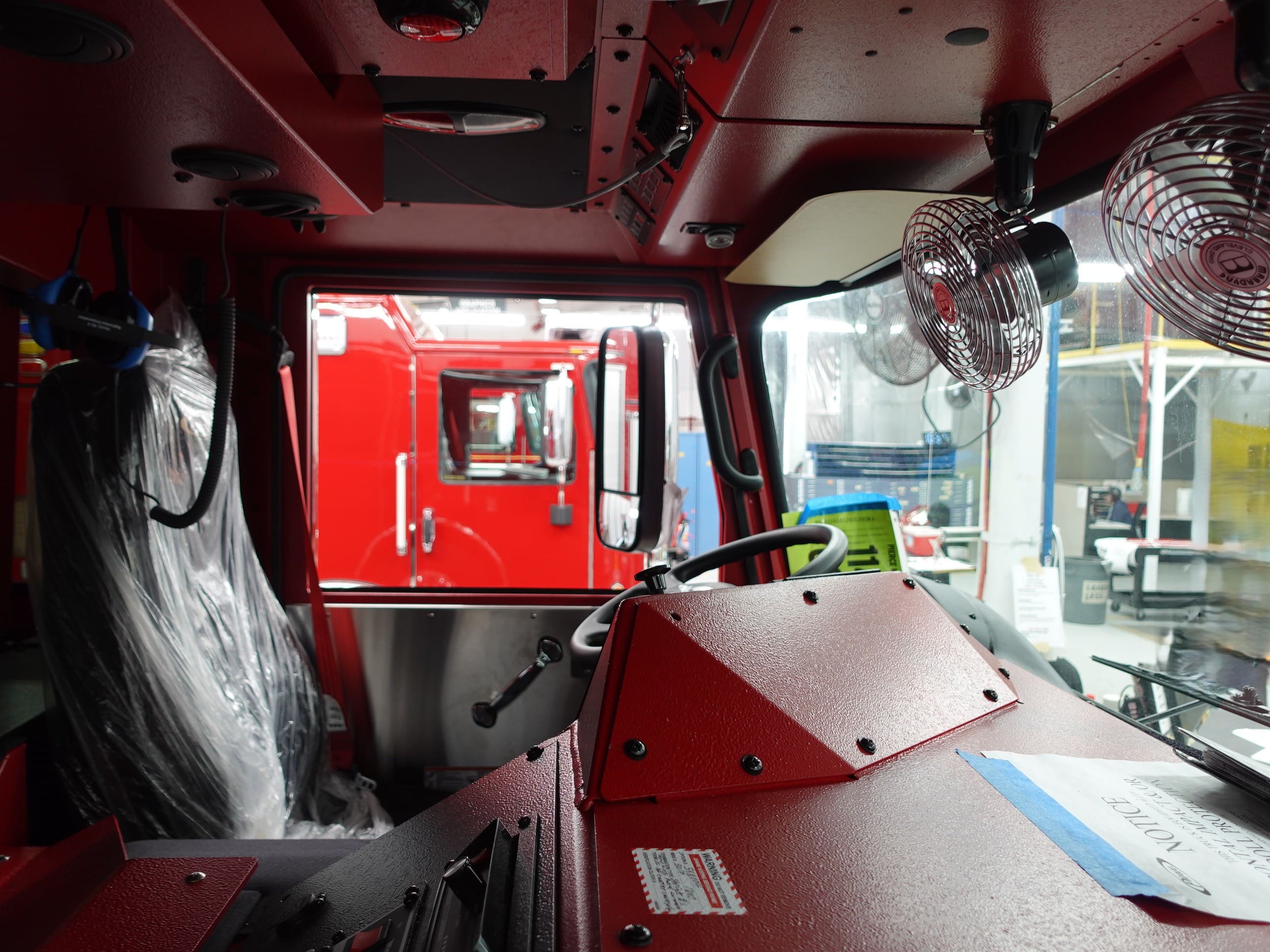

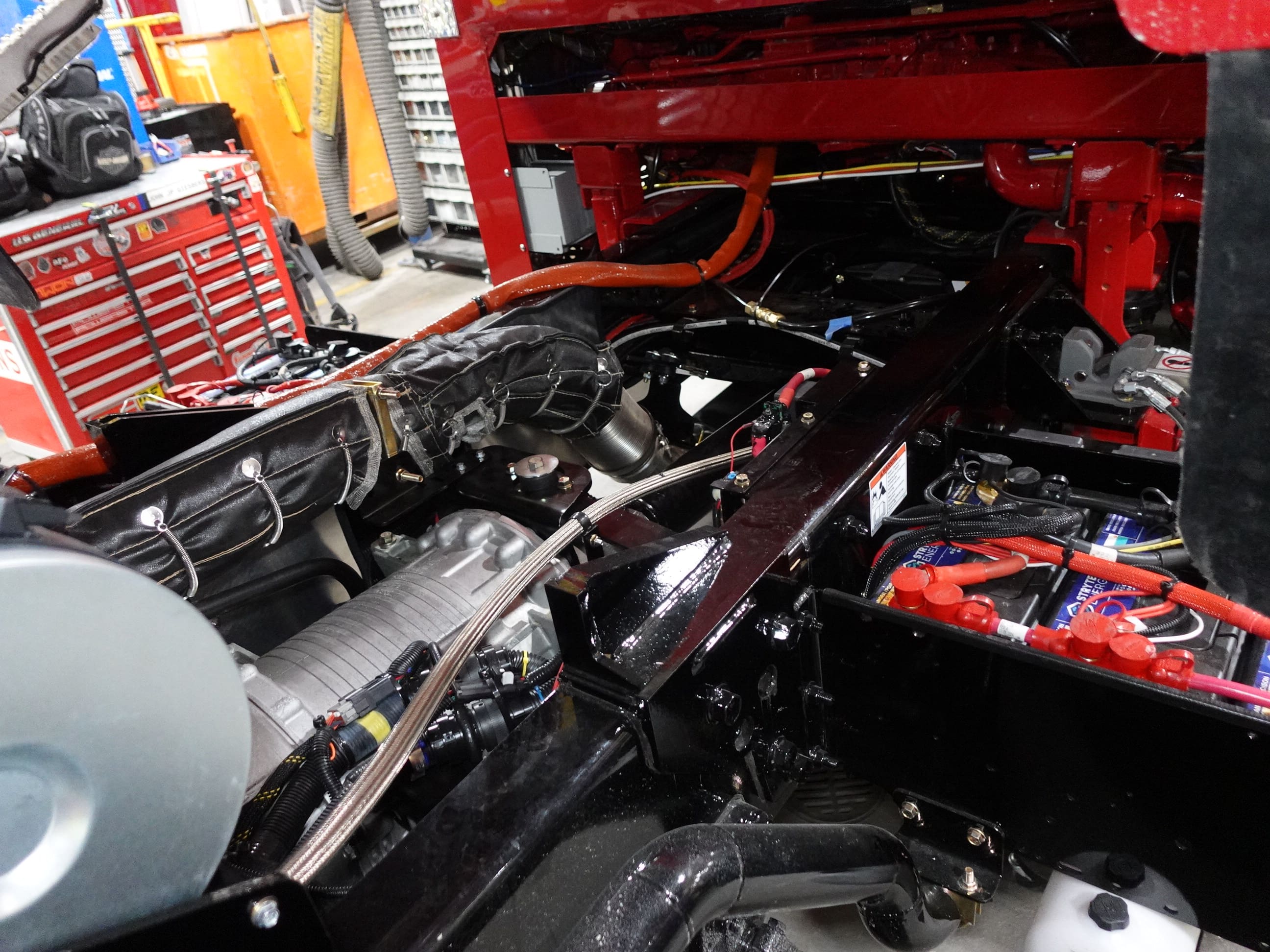

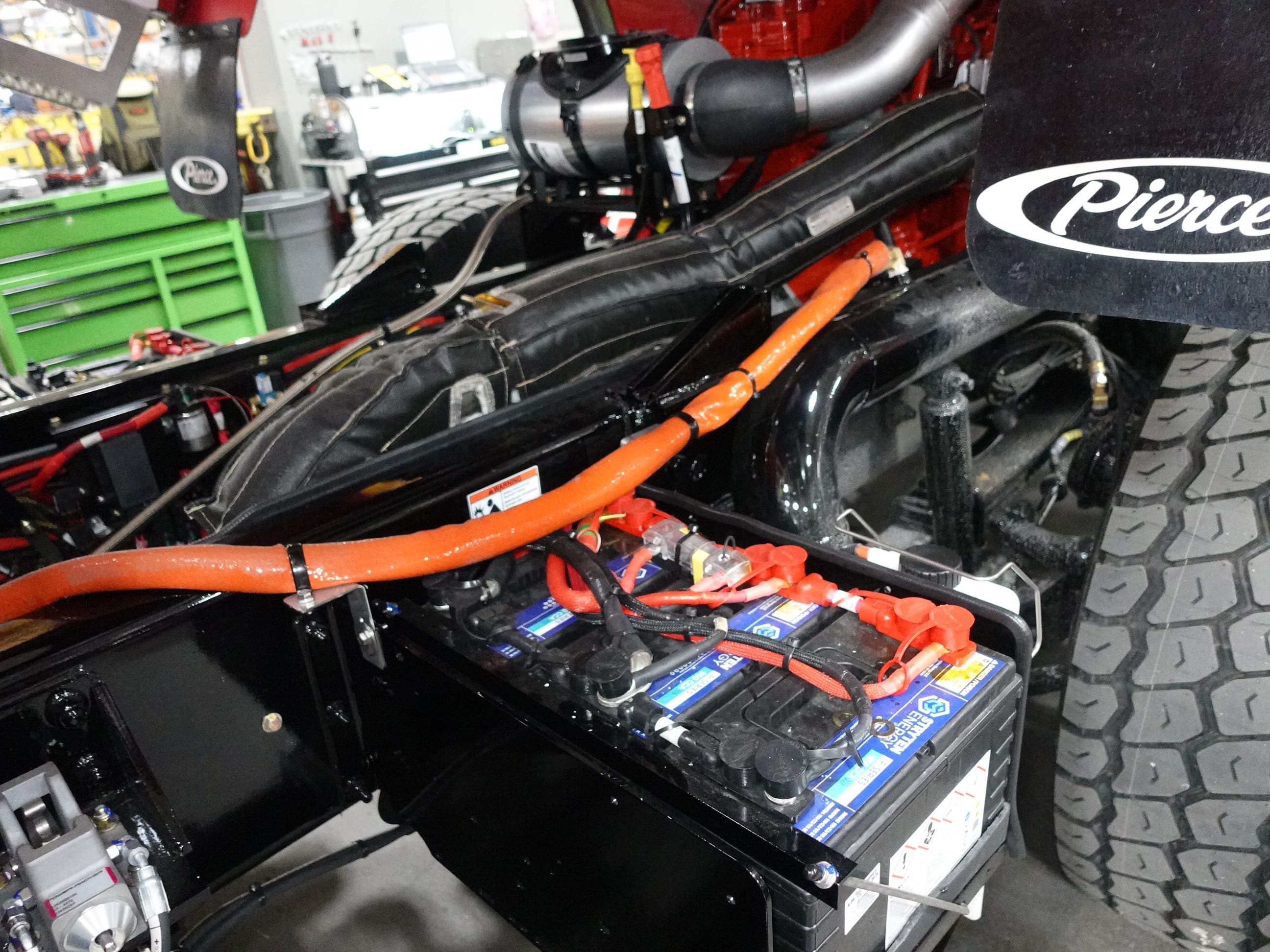

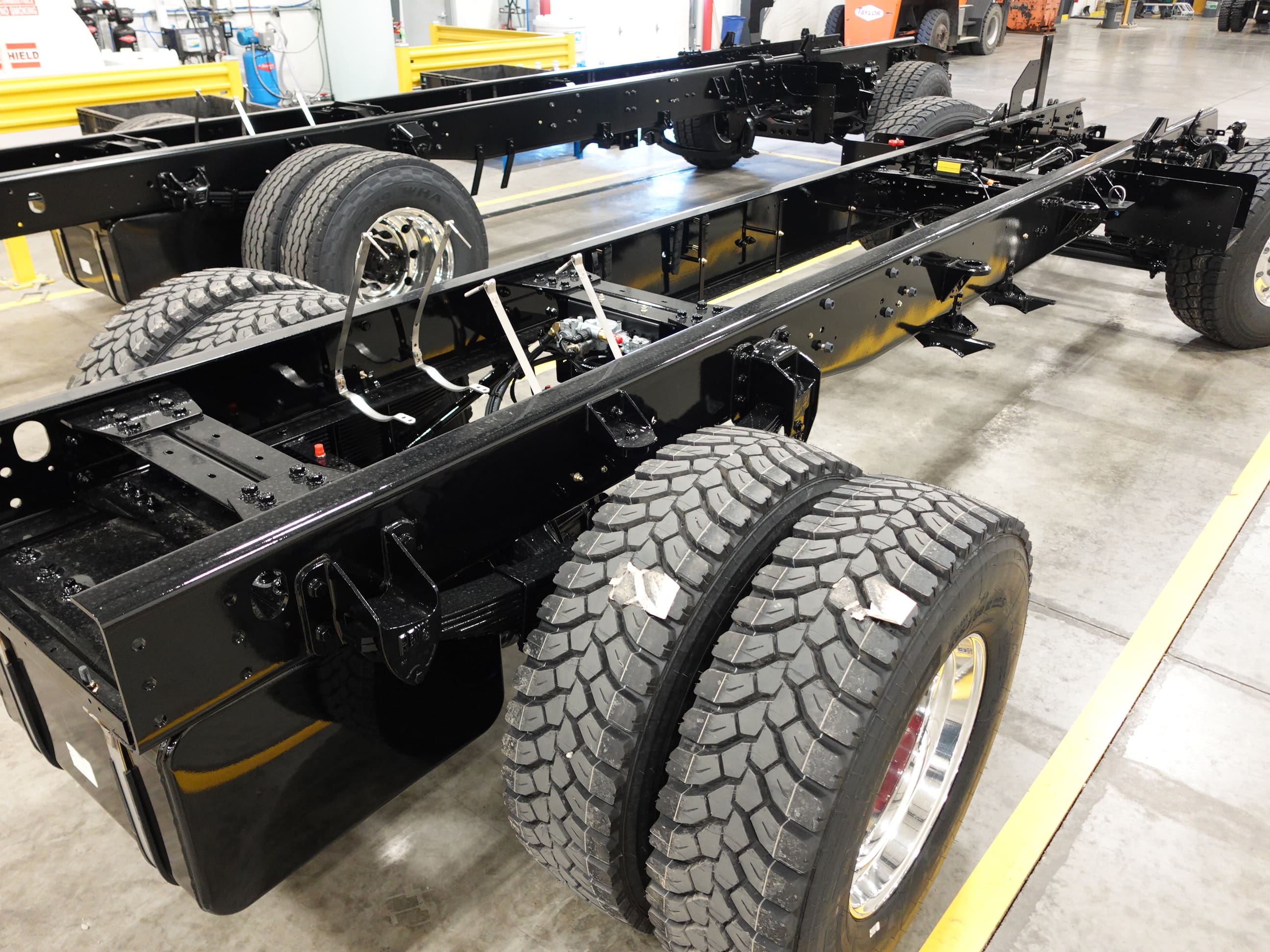

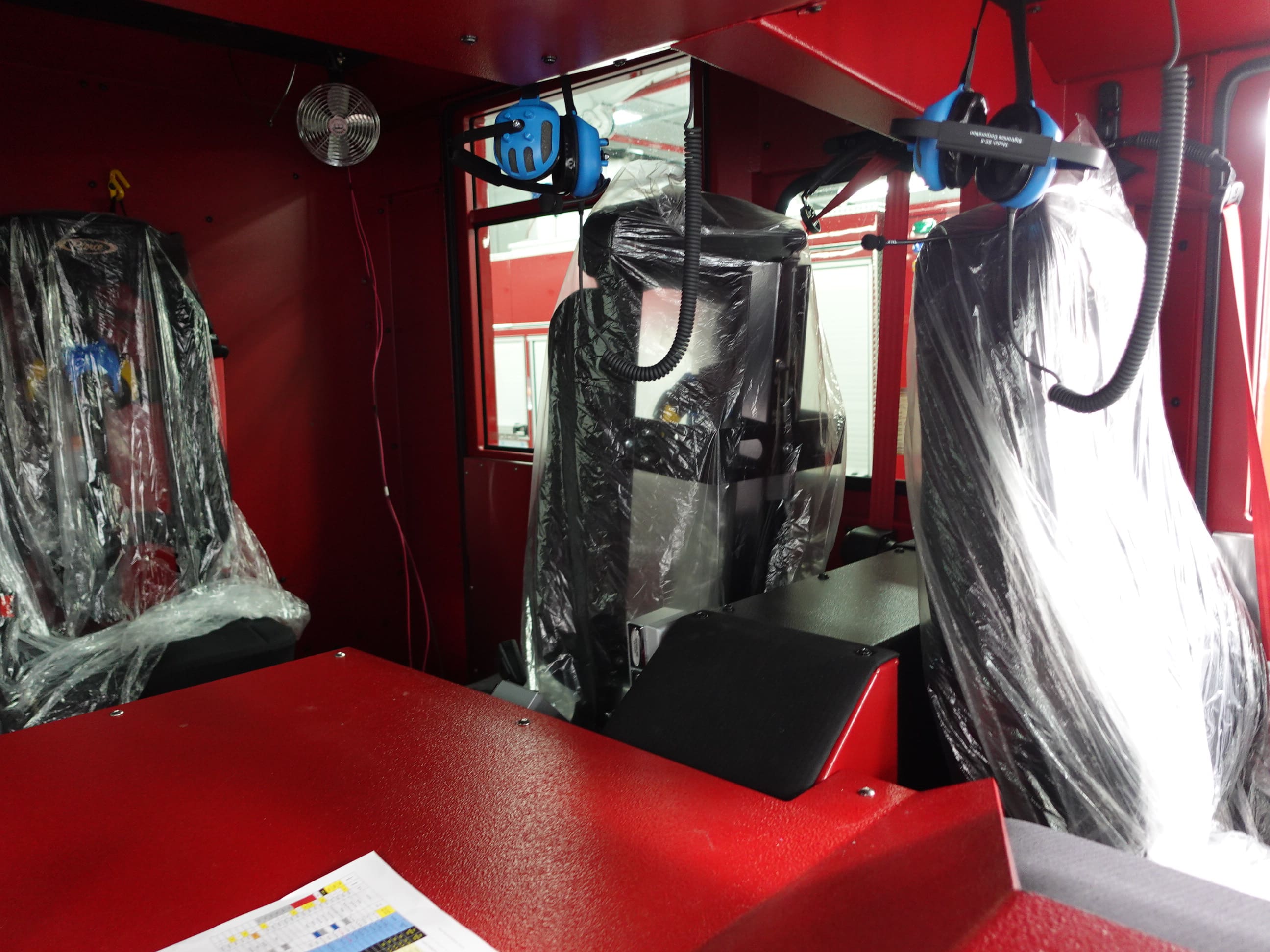

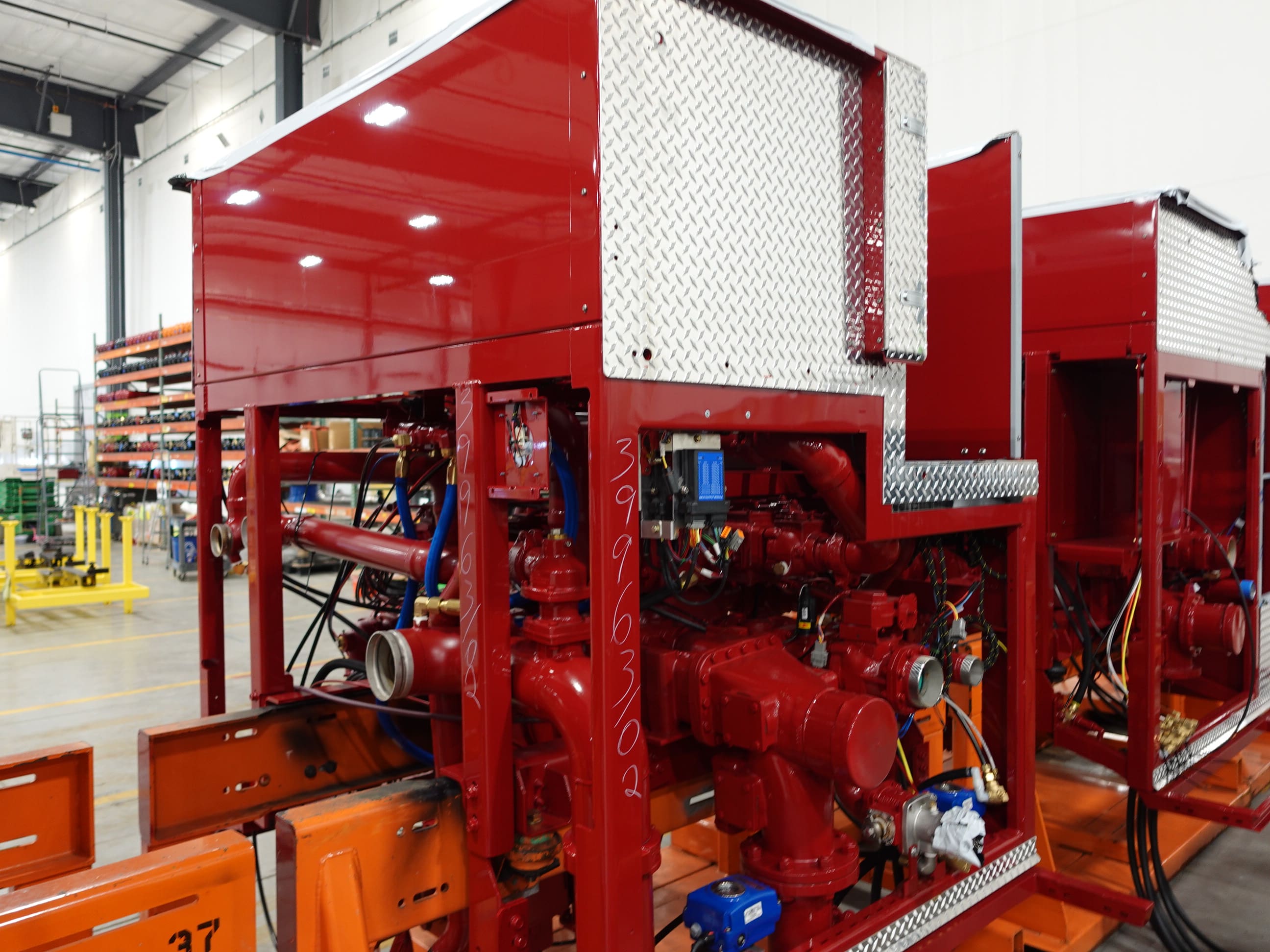

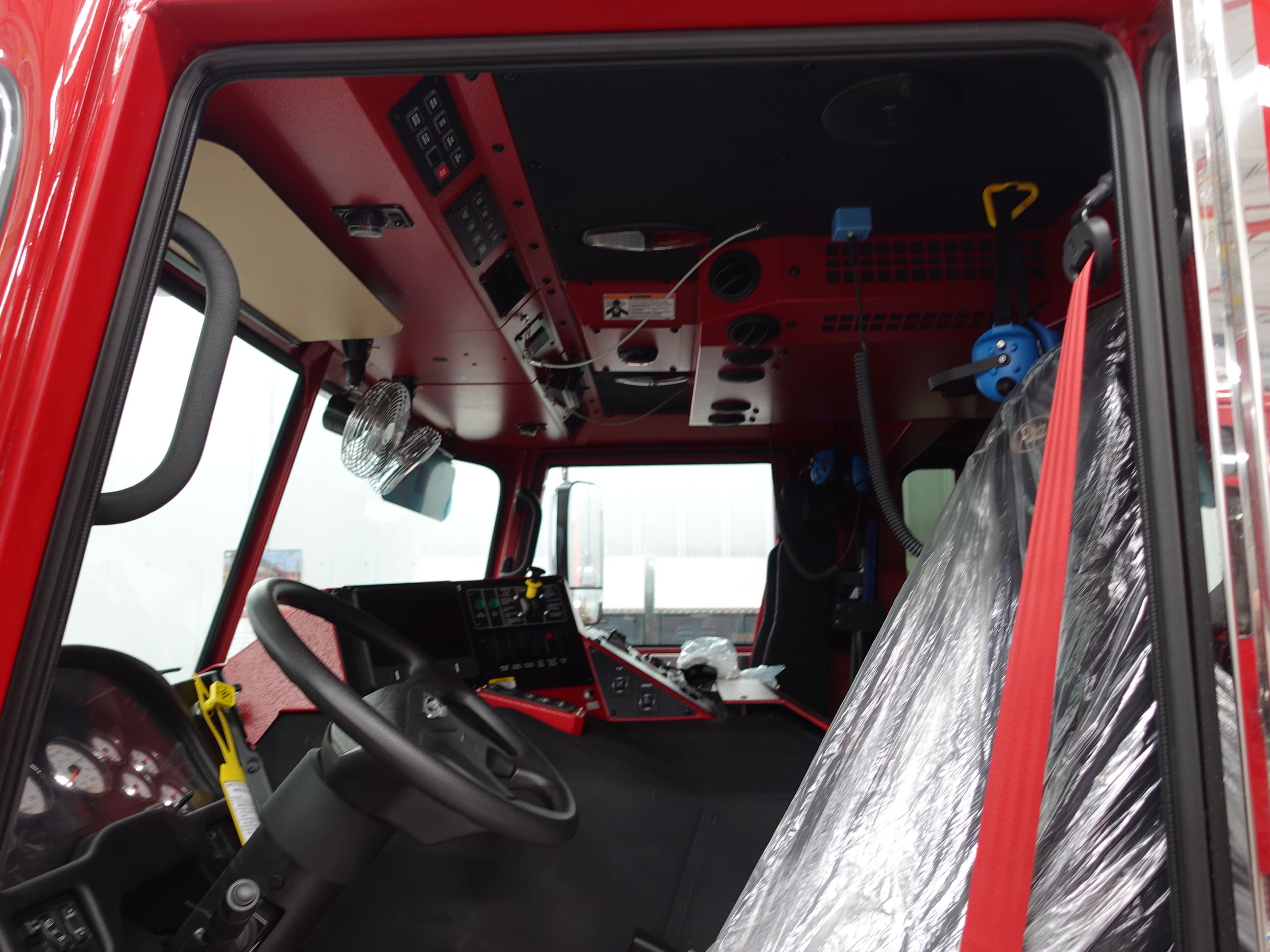

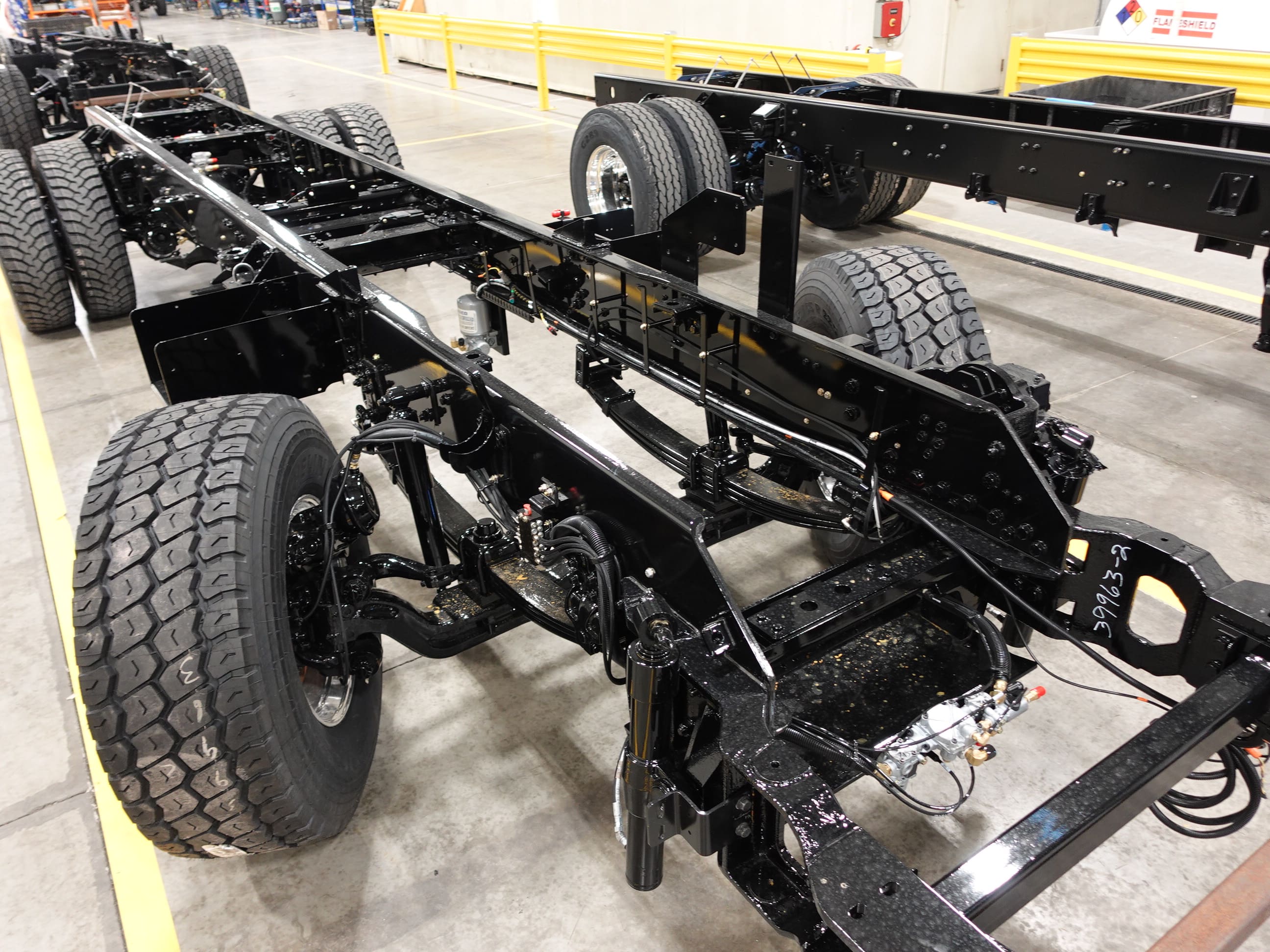

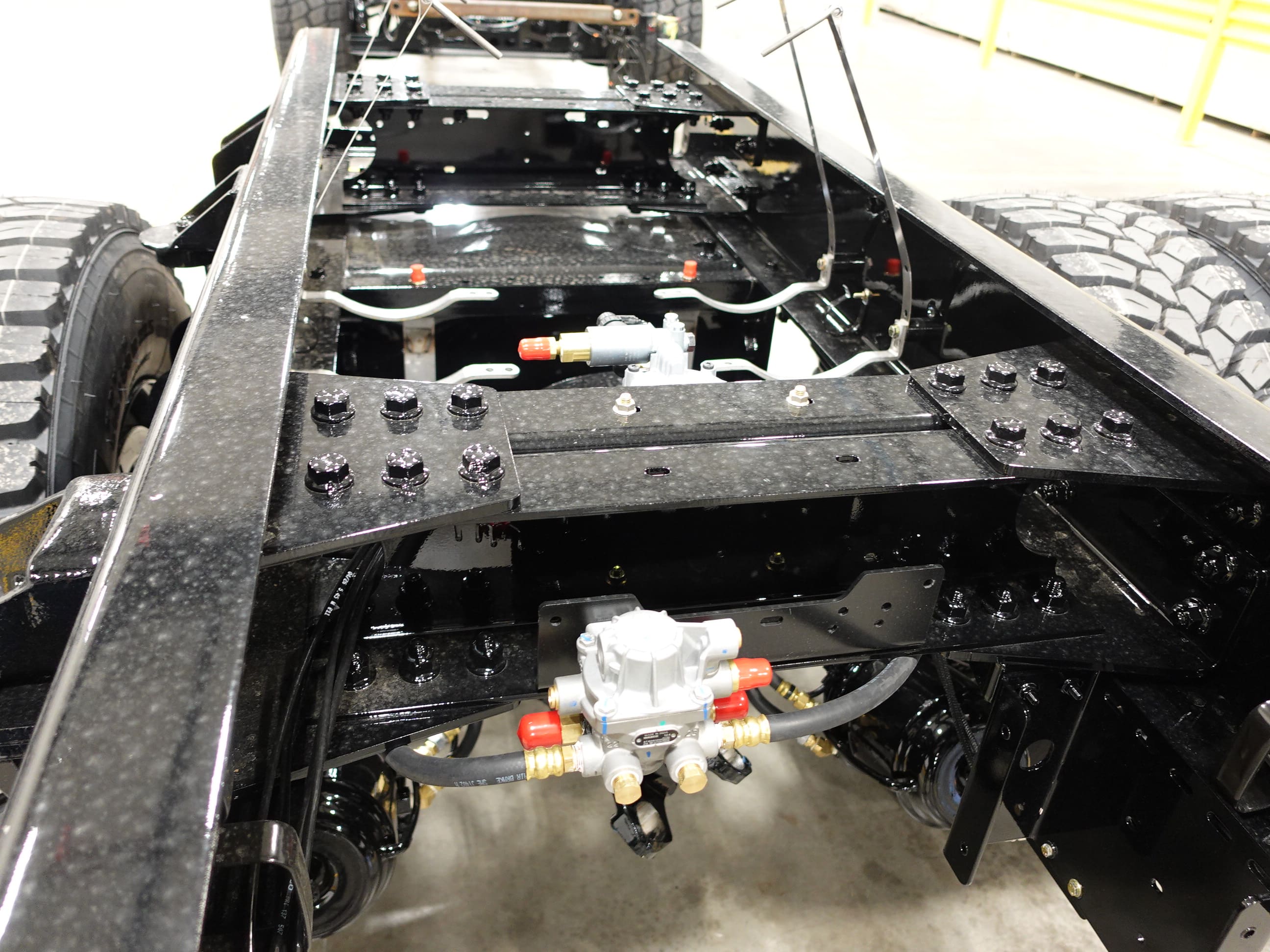

04-10-26

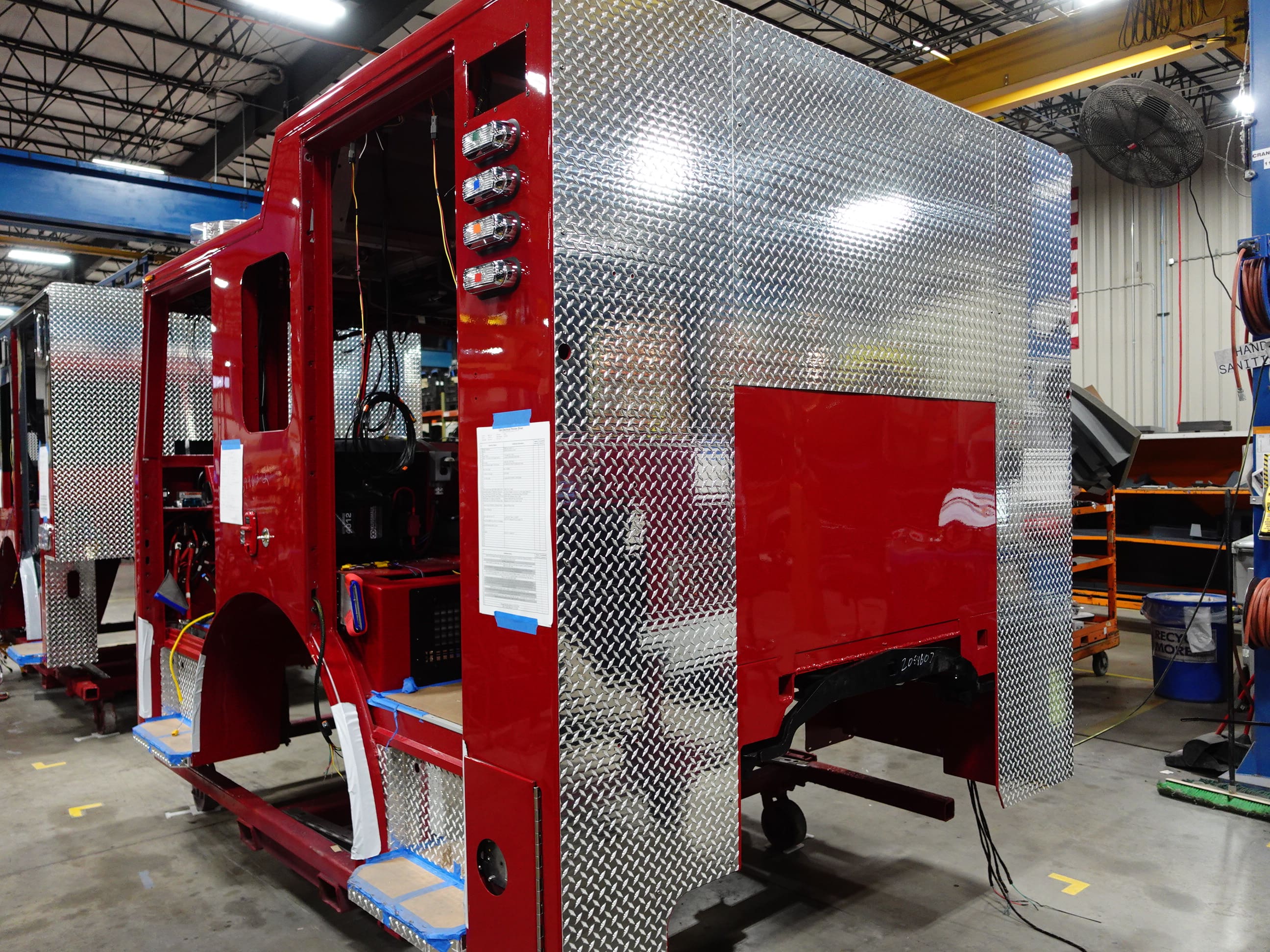

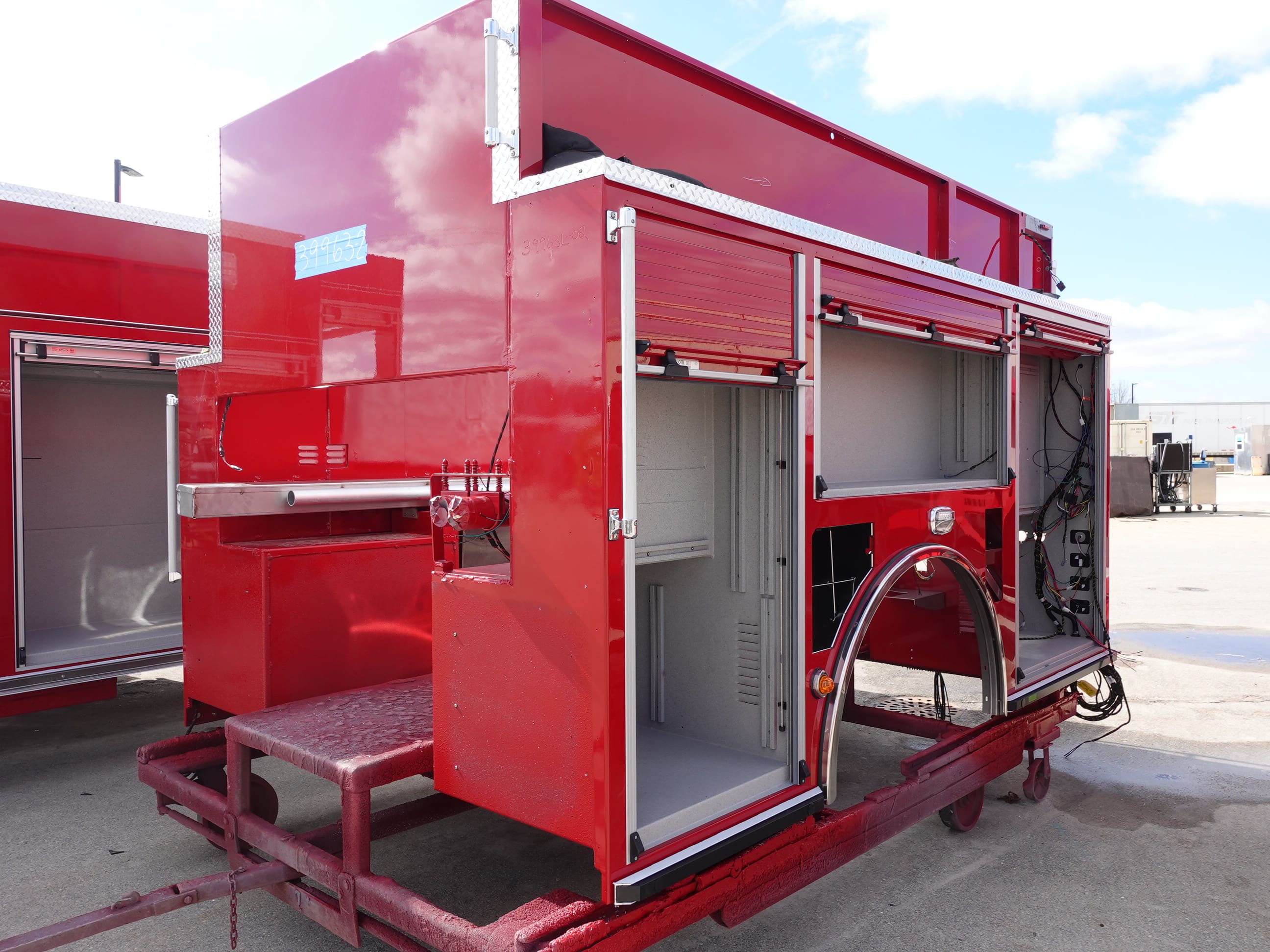

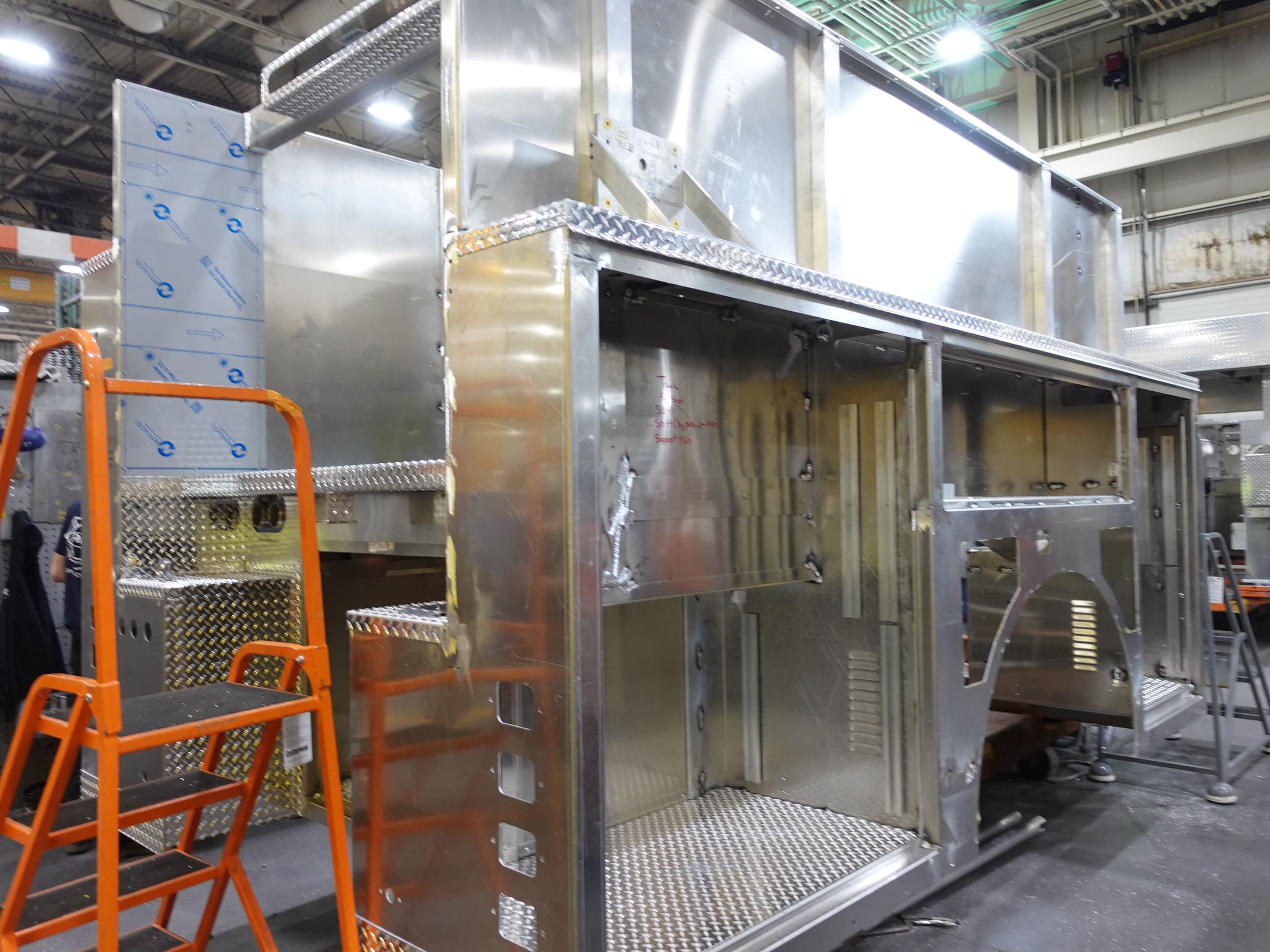

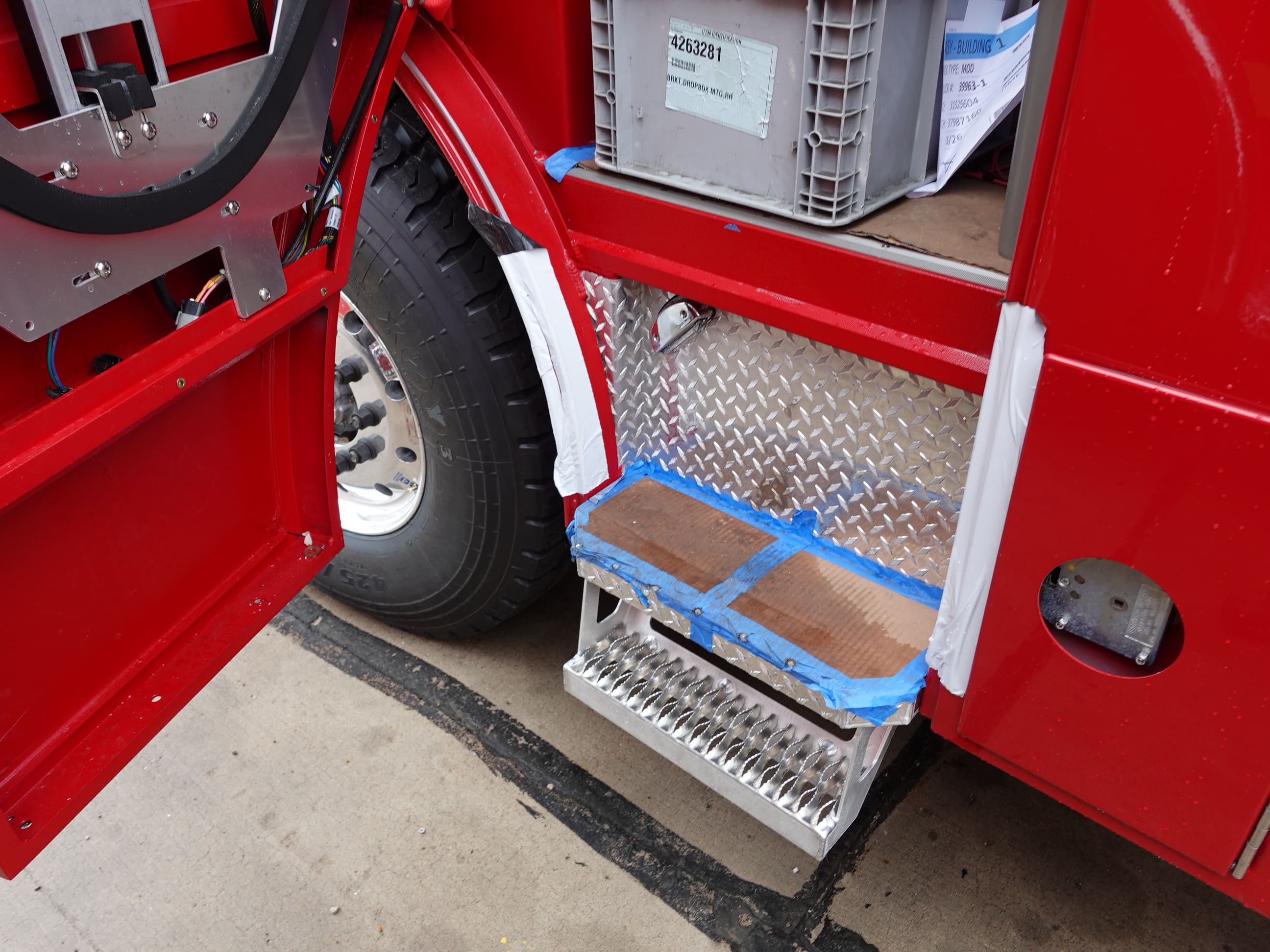

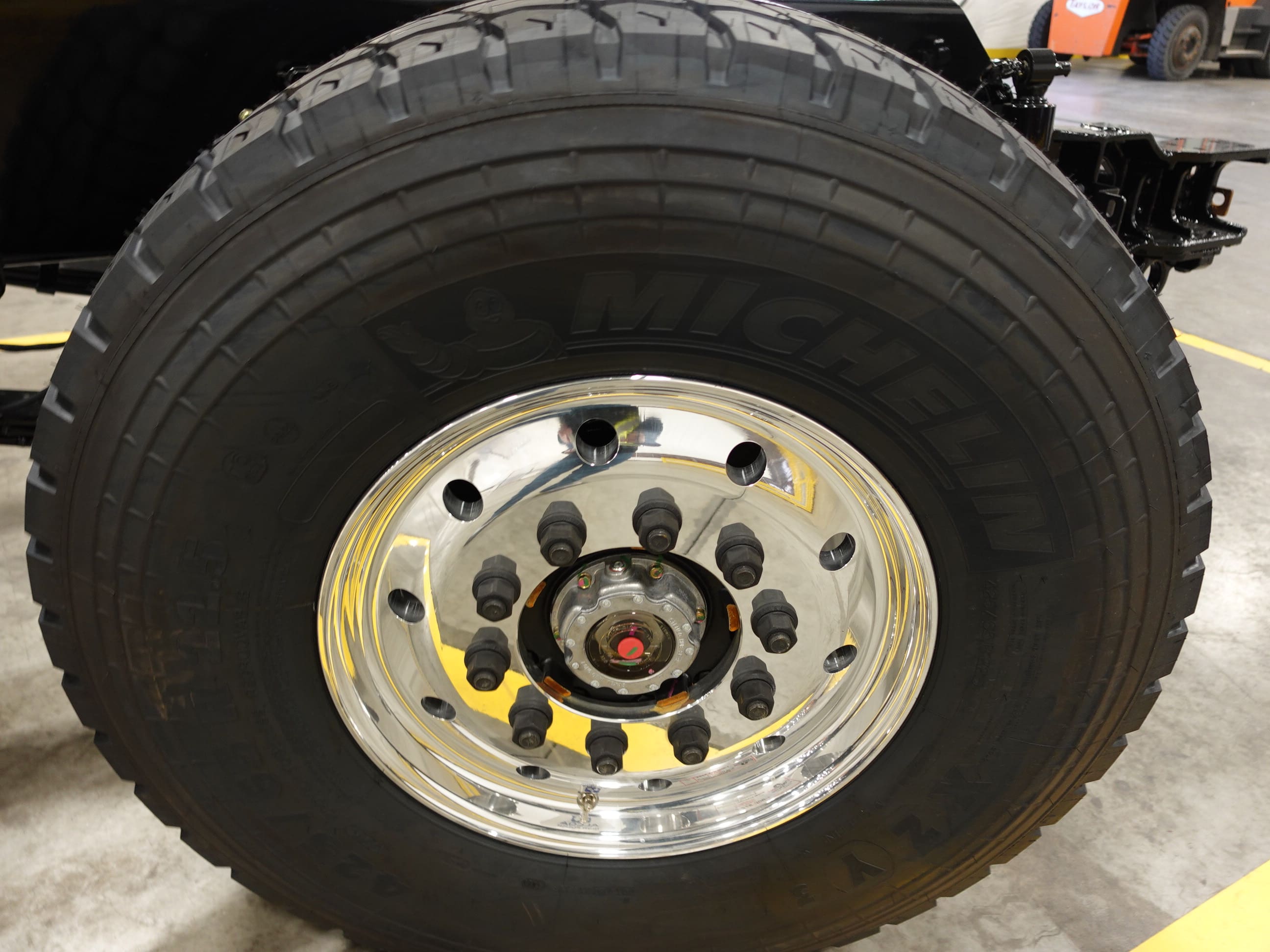

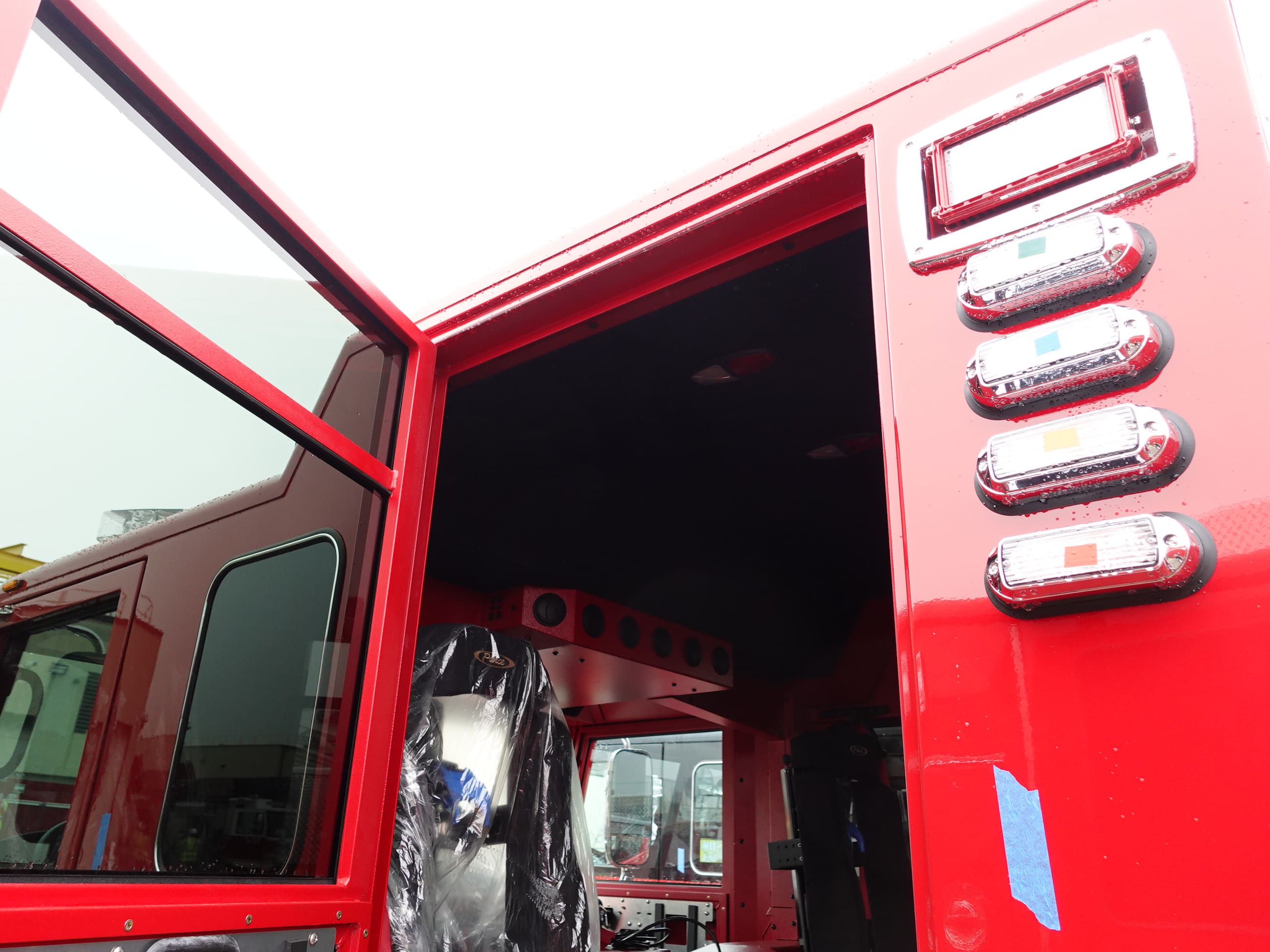

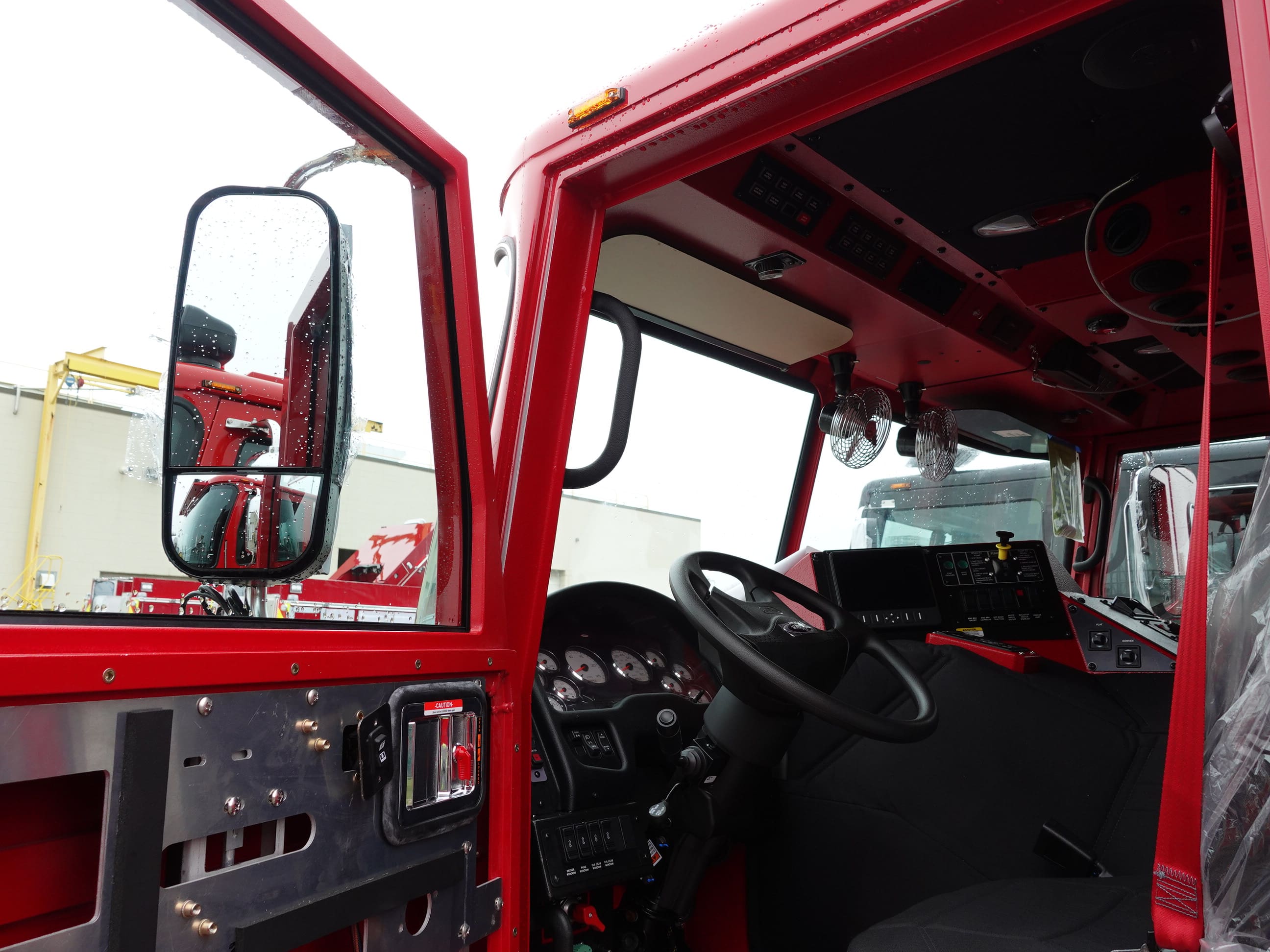

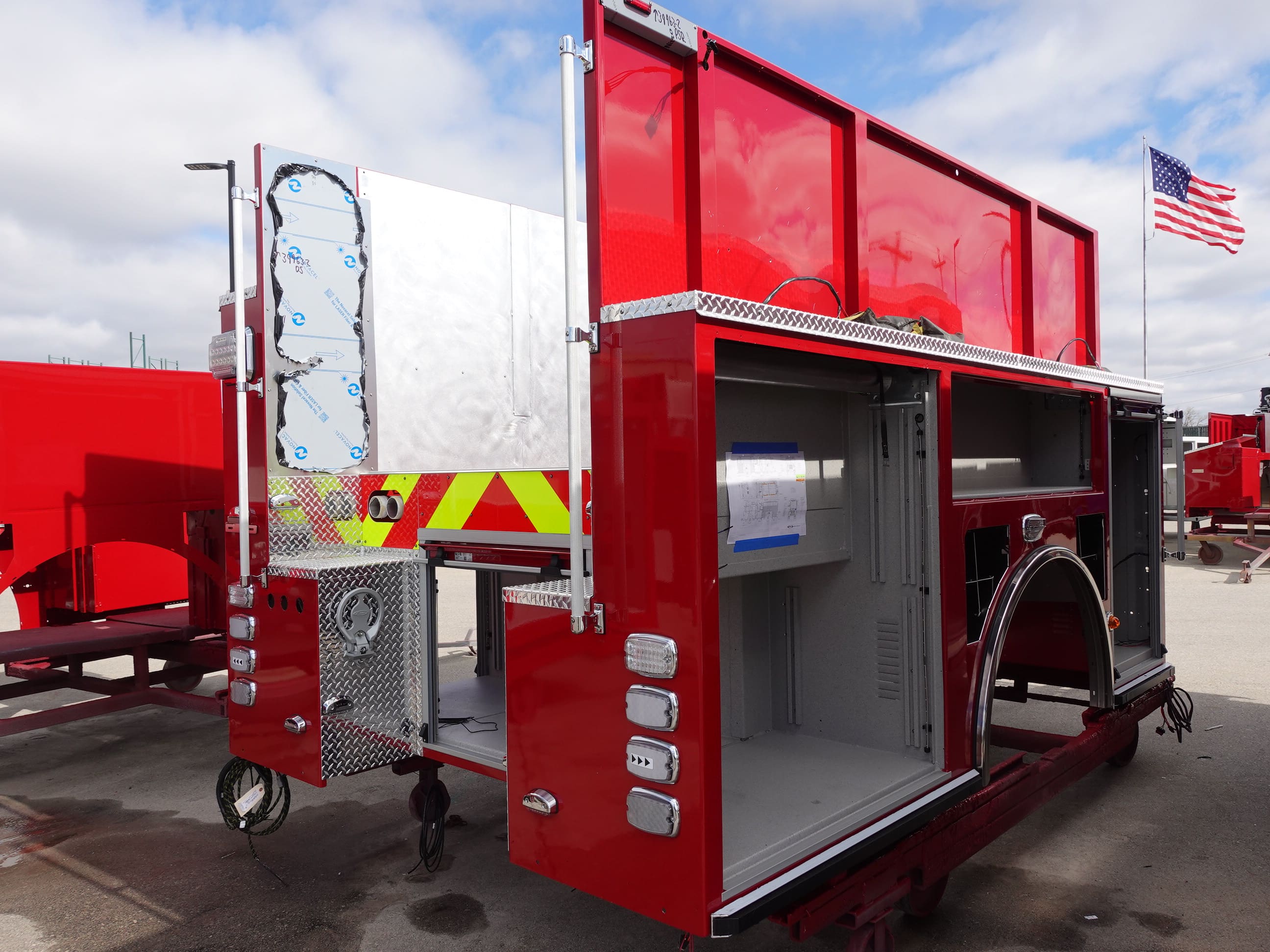

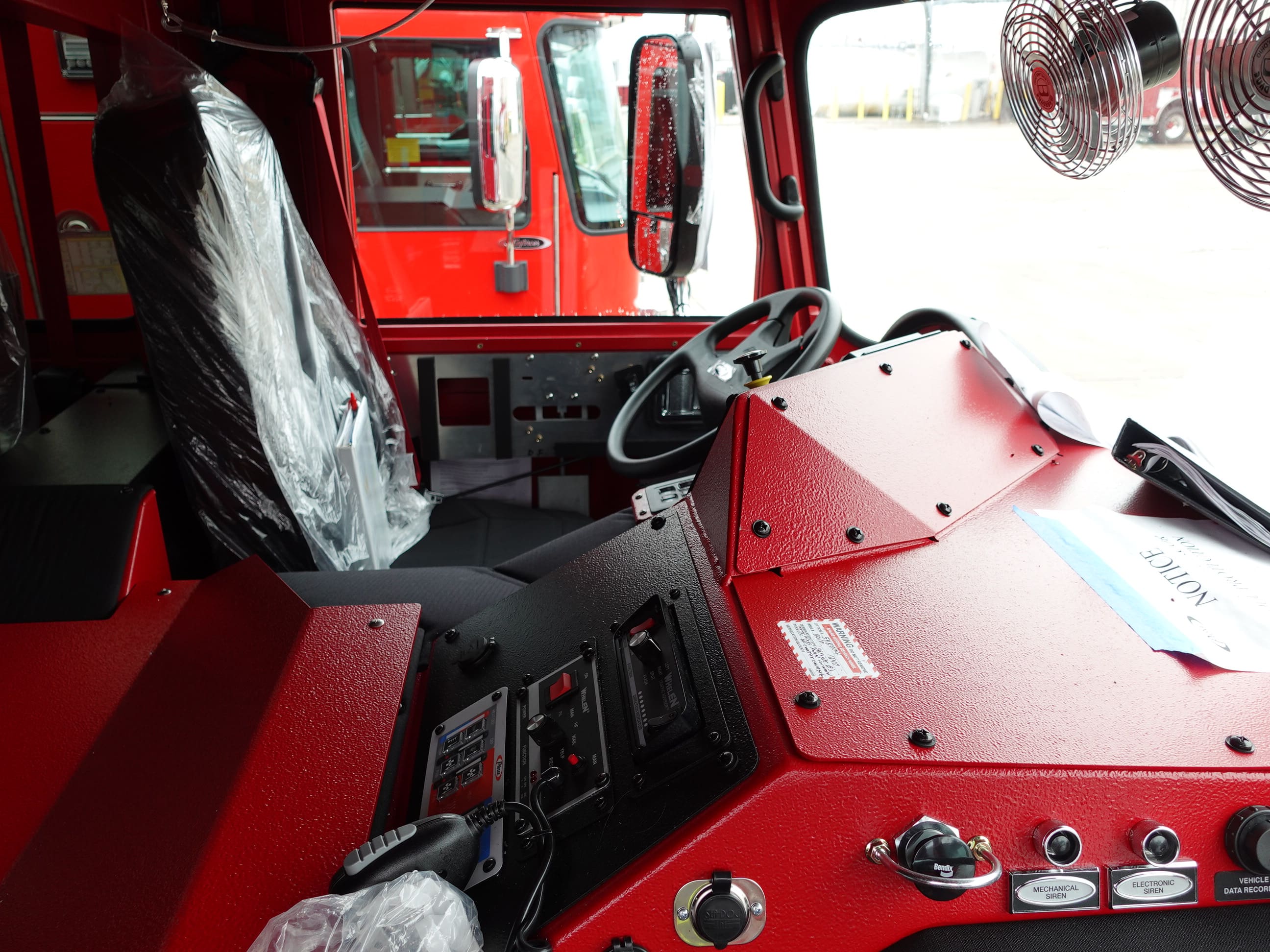

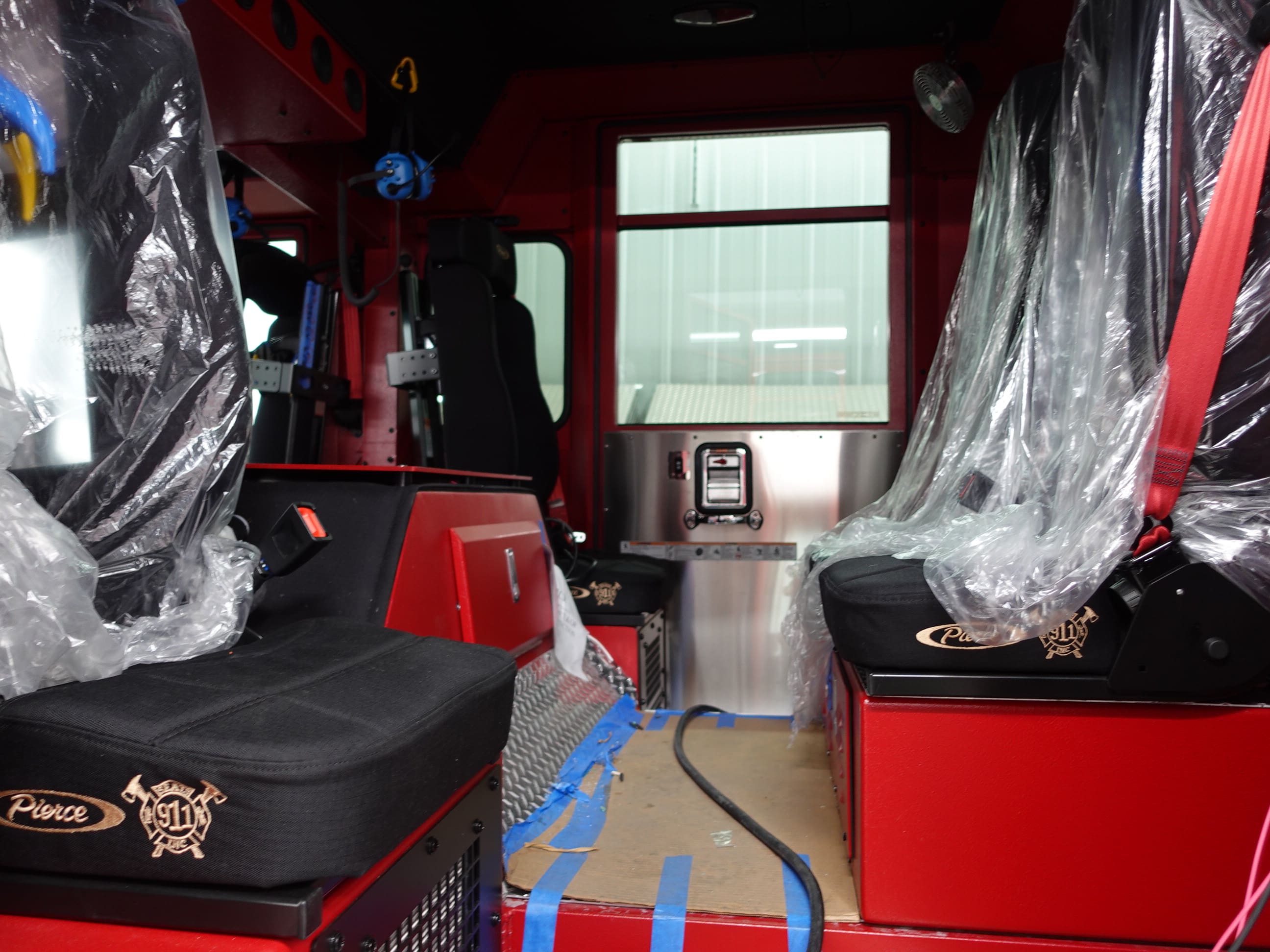

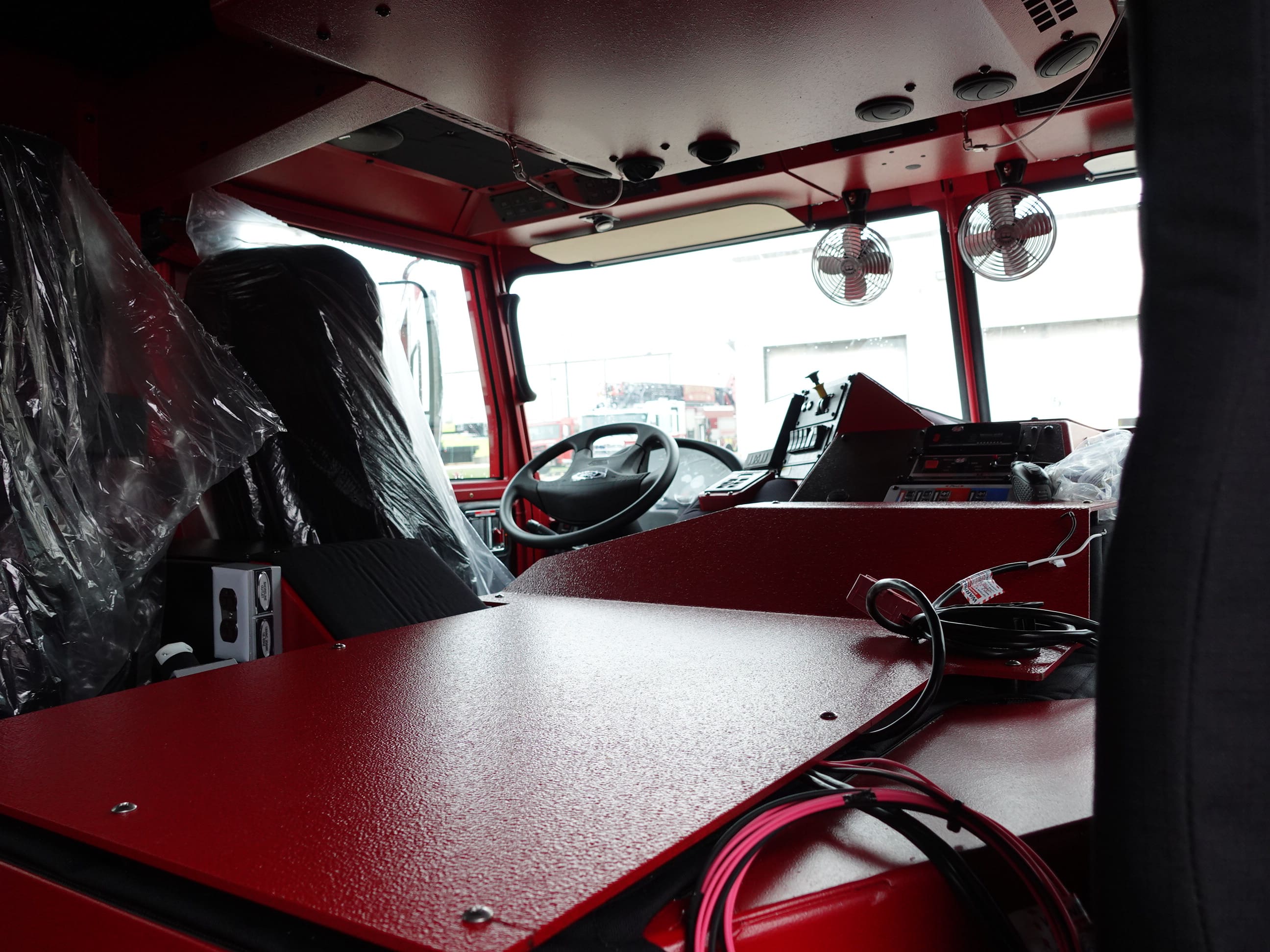

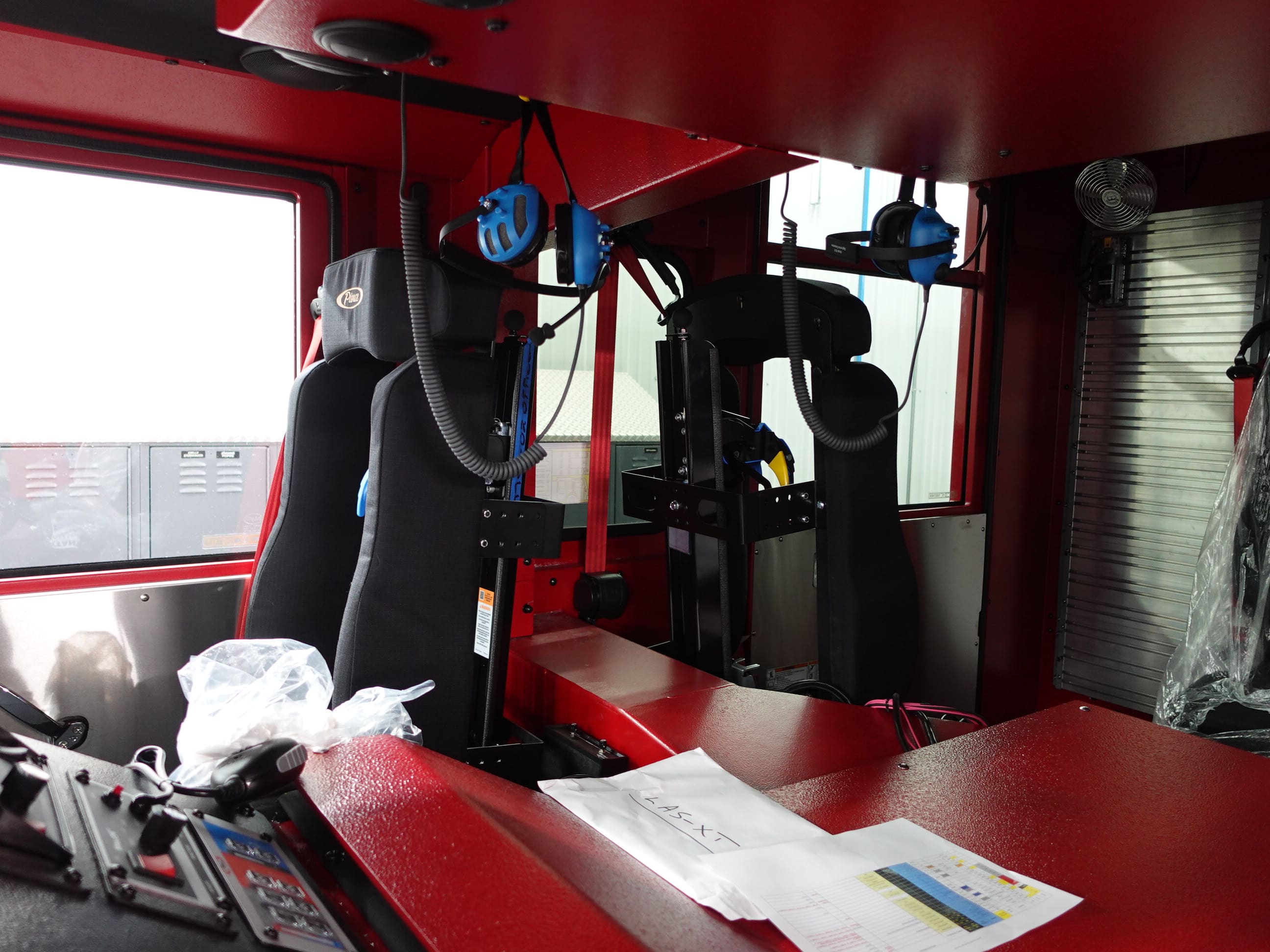

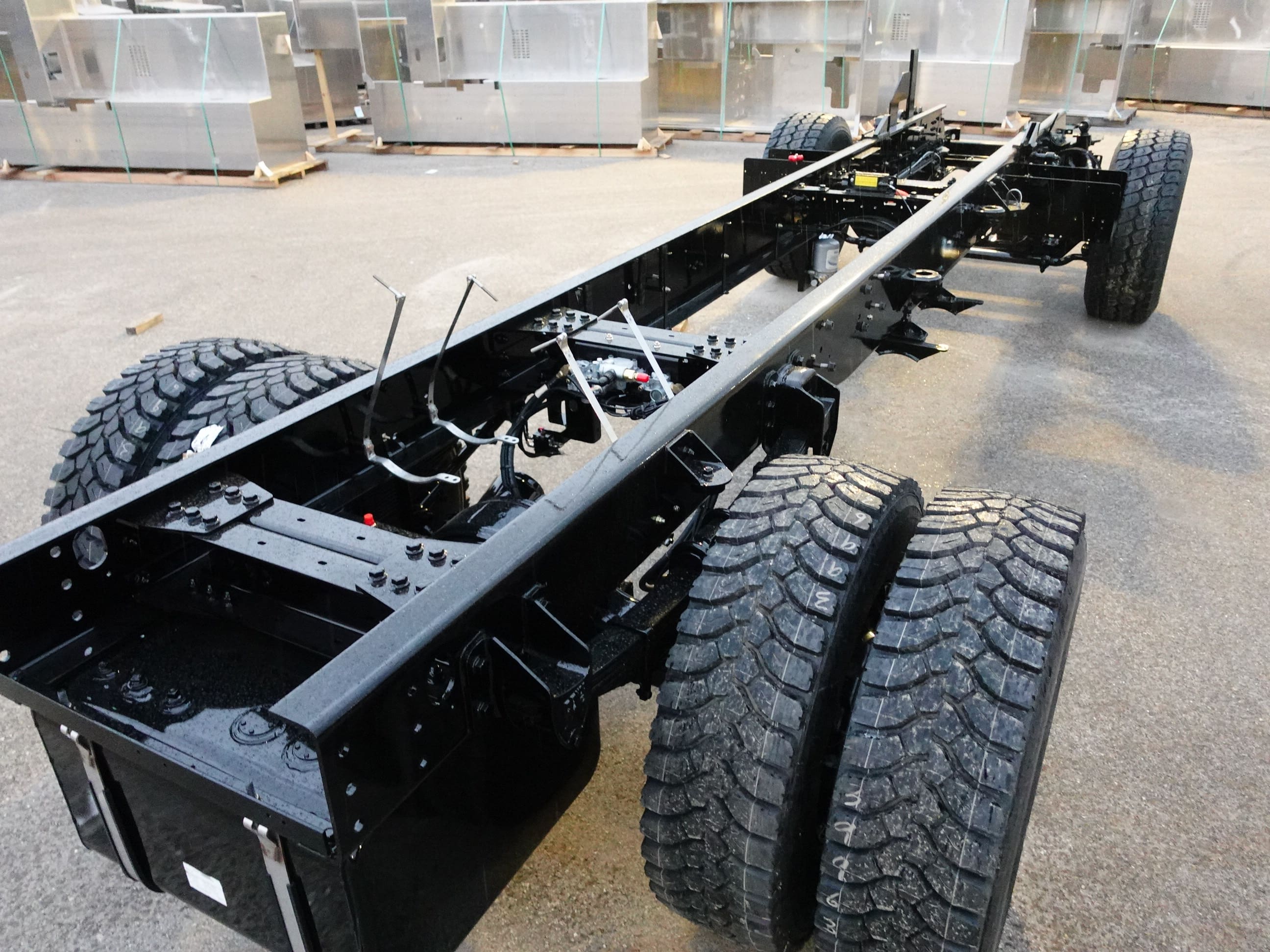

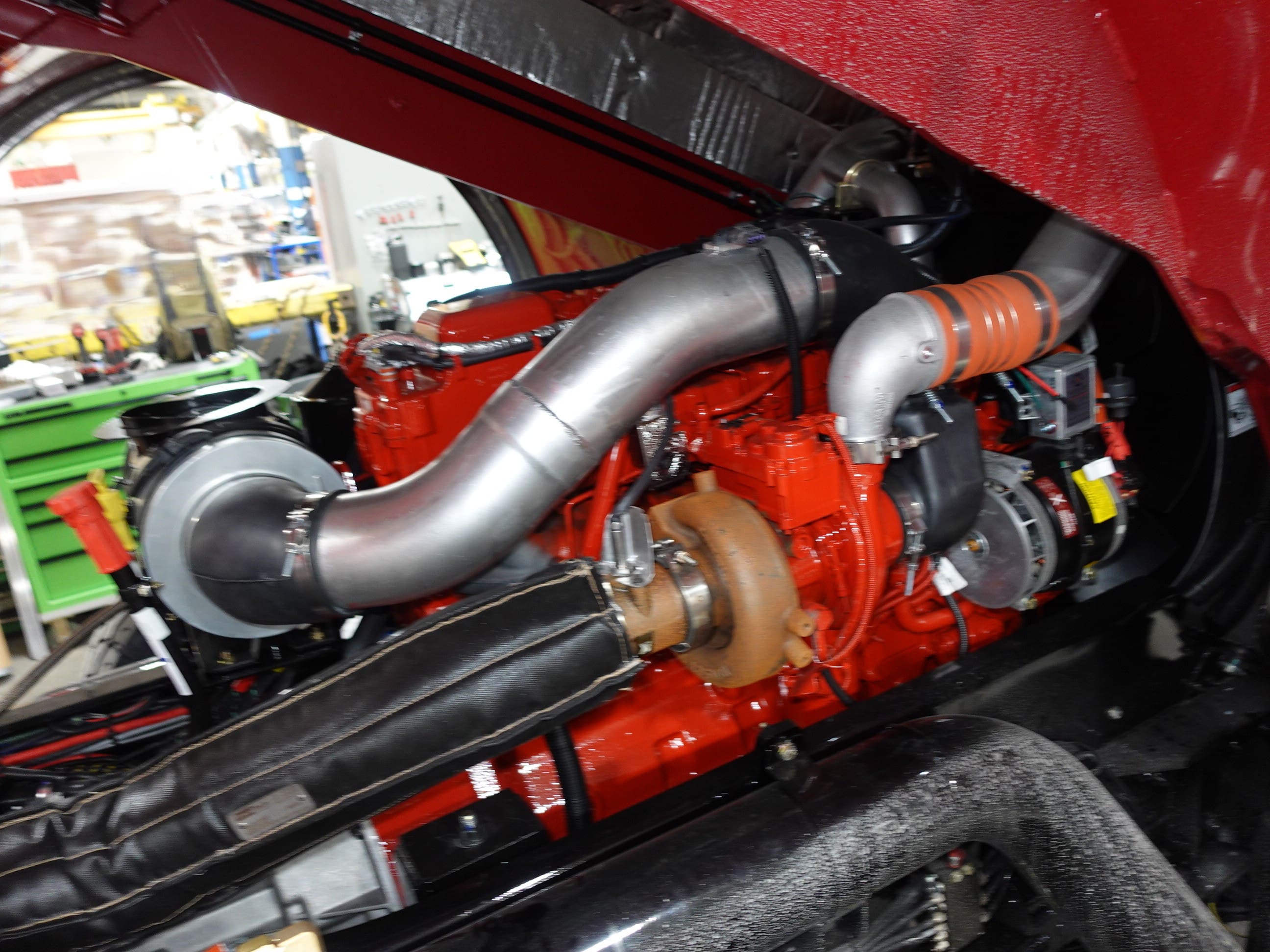

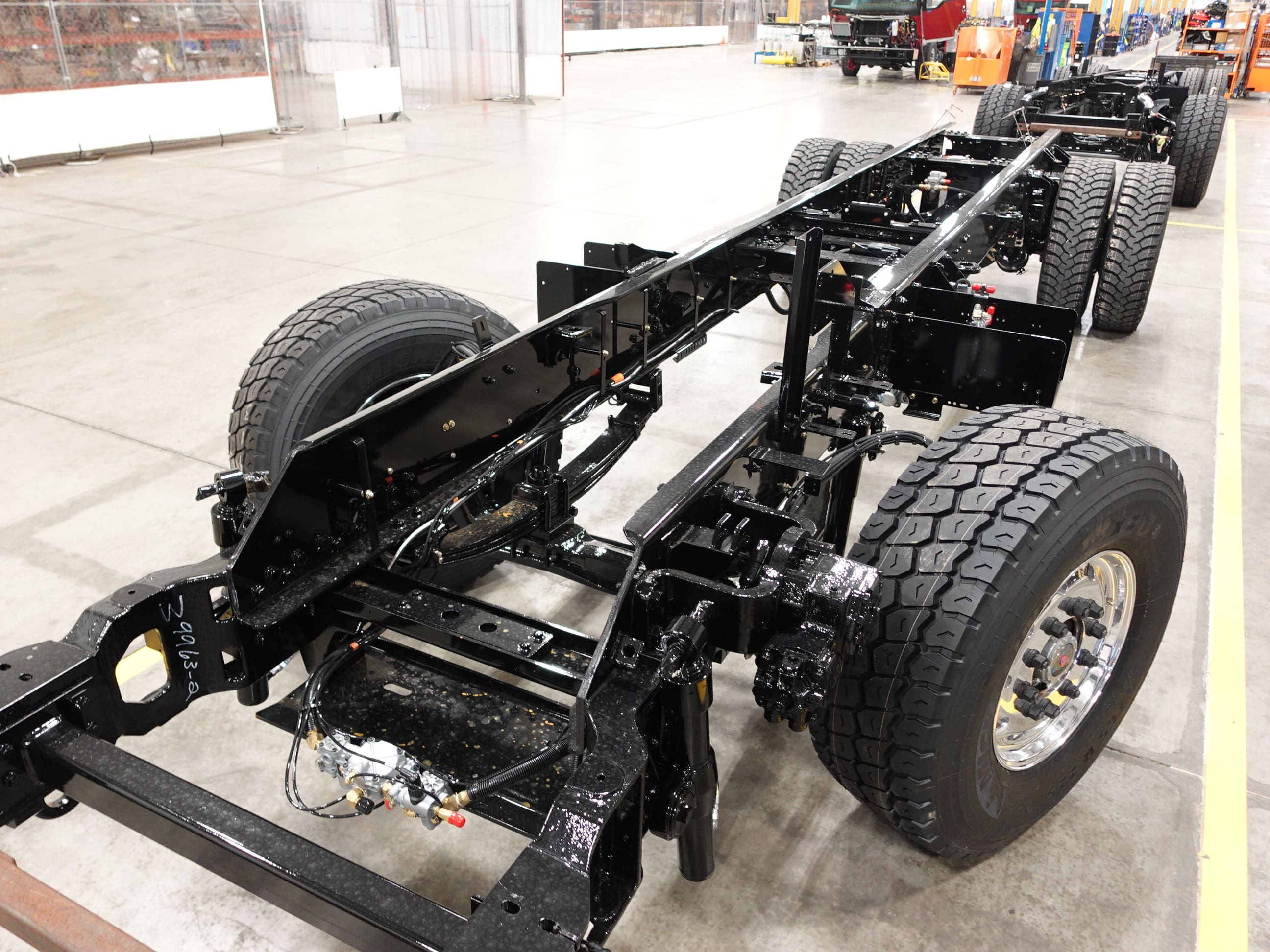

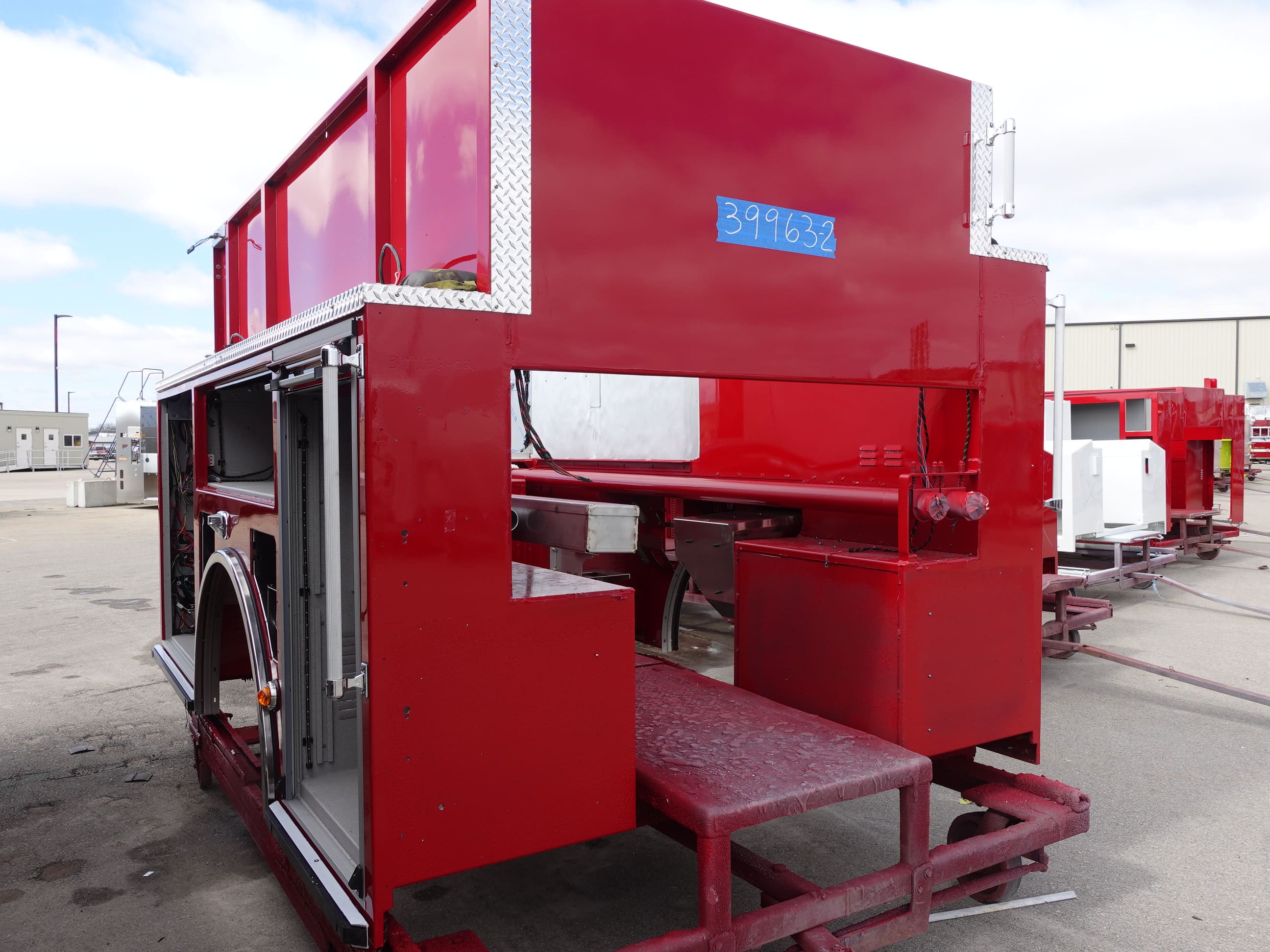

In this report, the cab completed initial assembly, the frame build continued, the pump house completed initial assembly, and the body completed initial assembly.

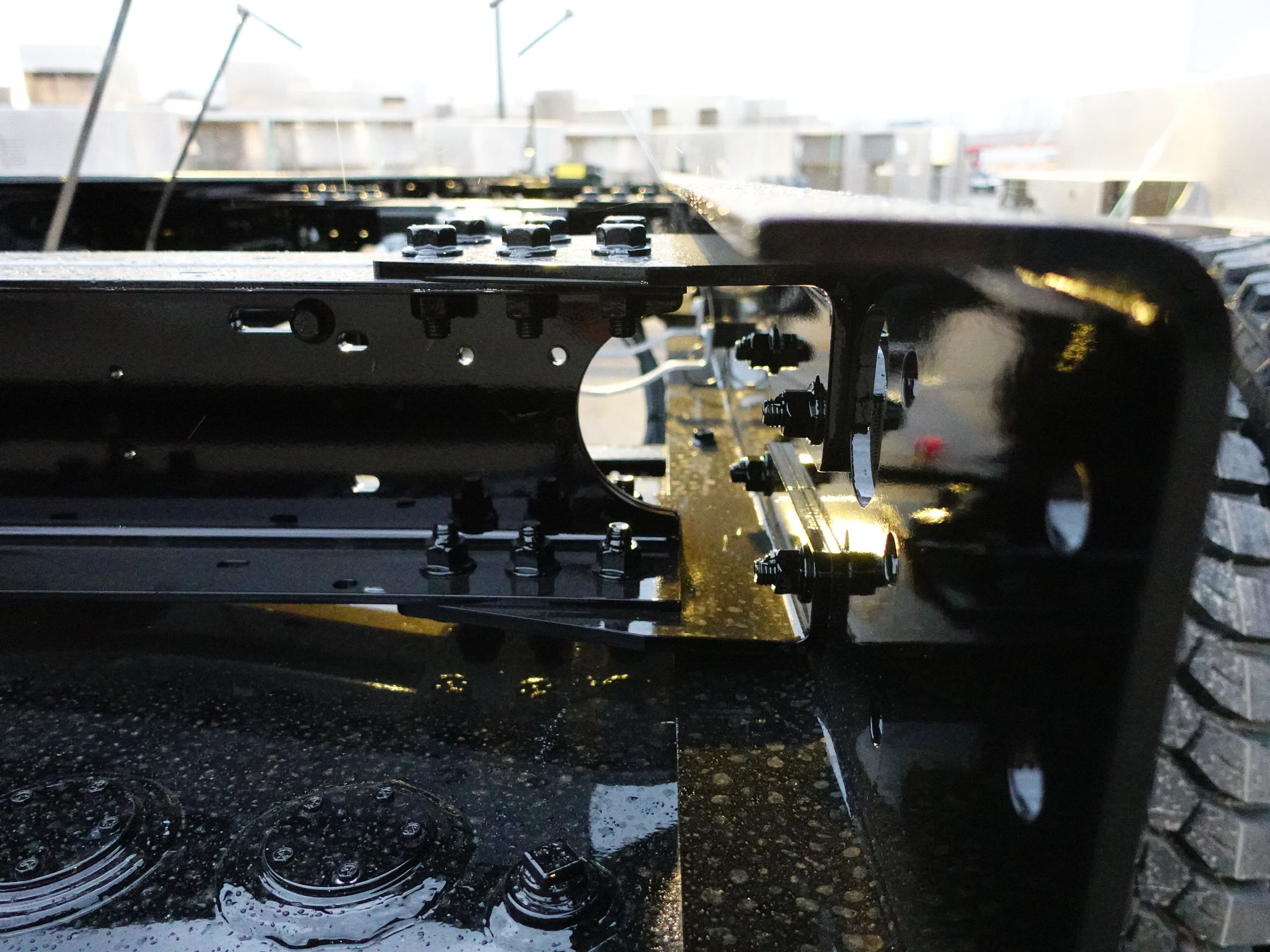

04-03-26

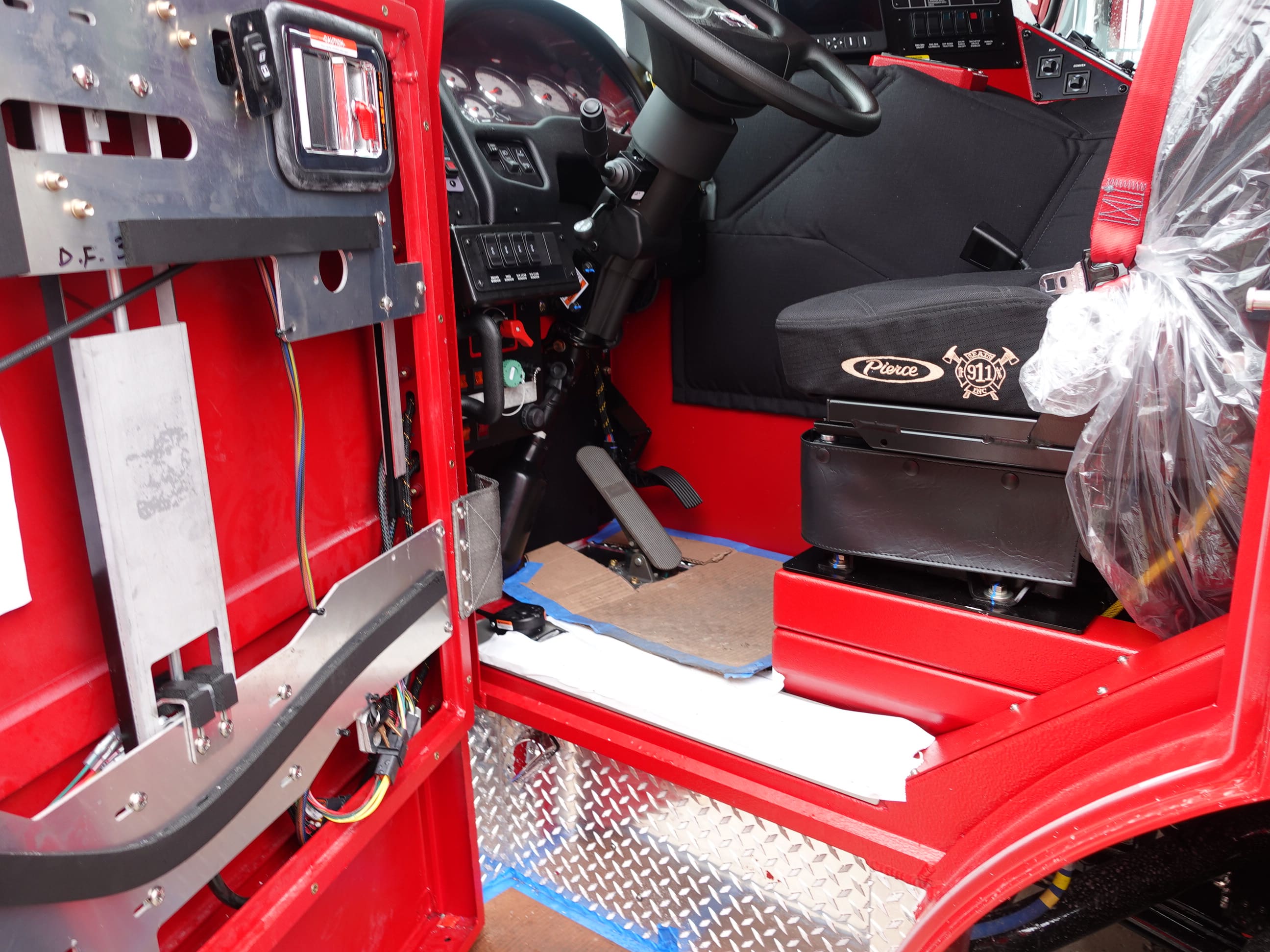

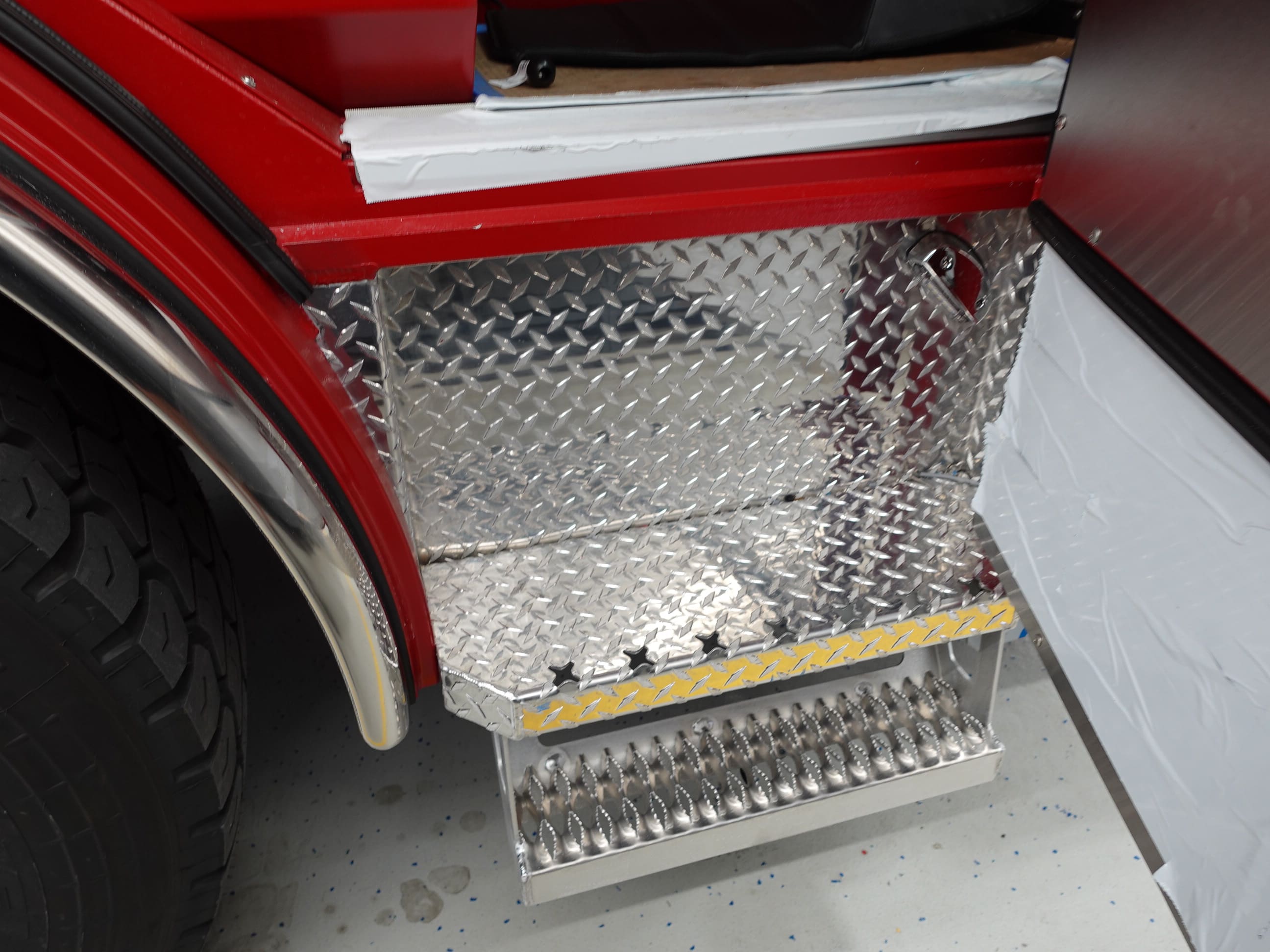

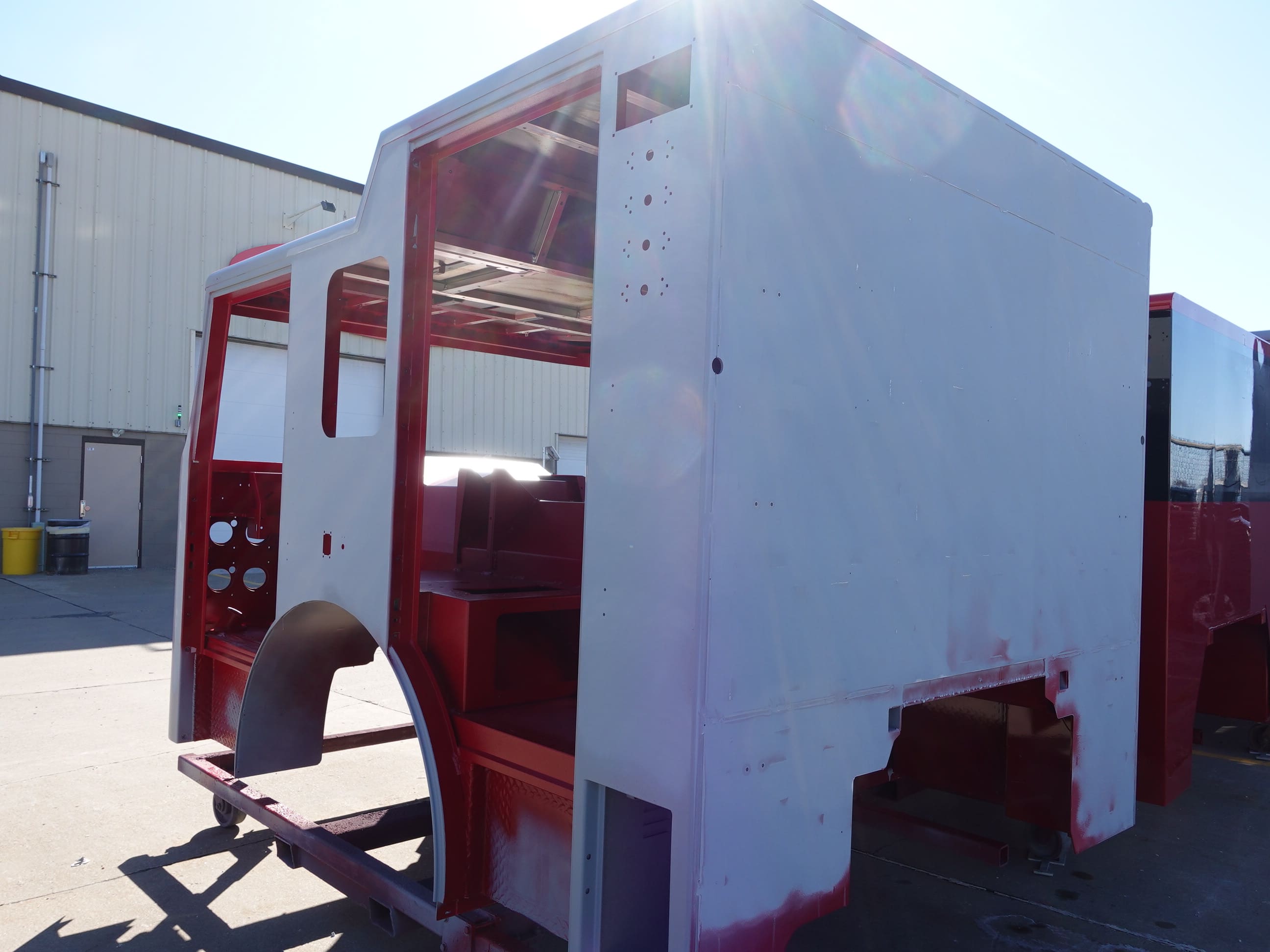

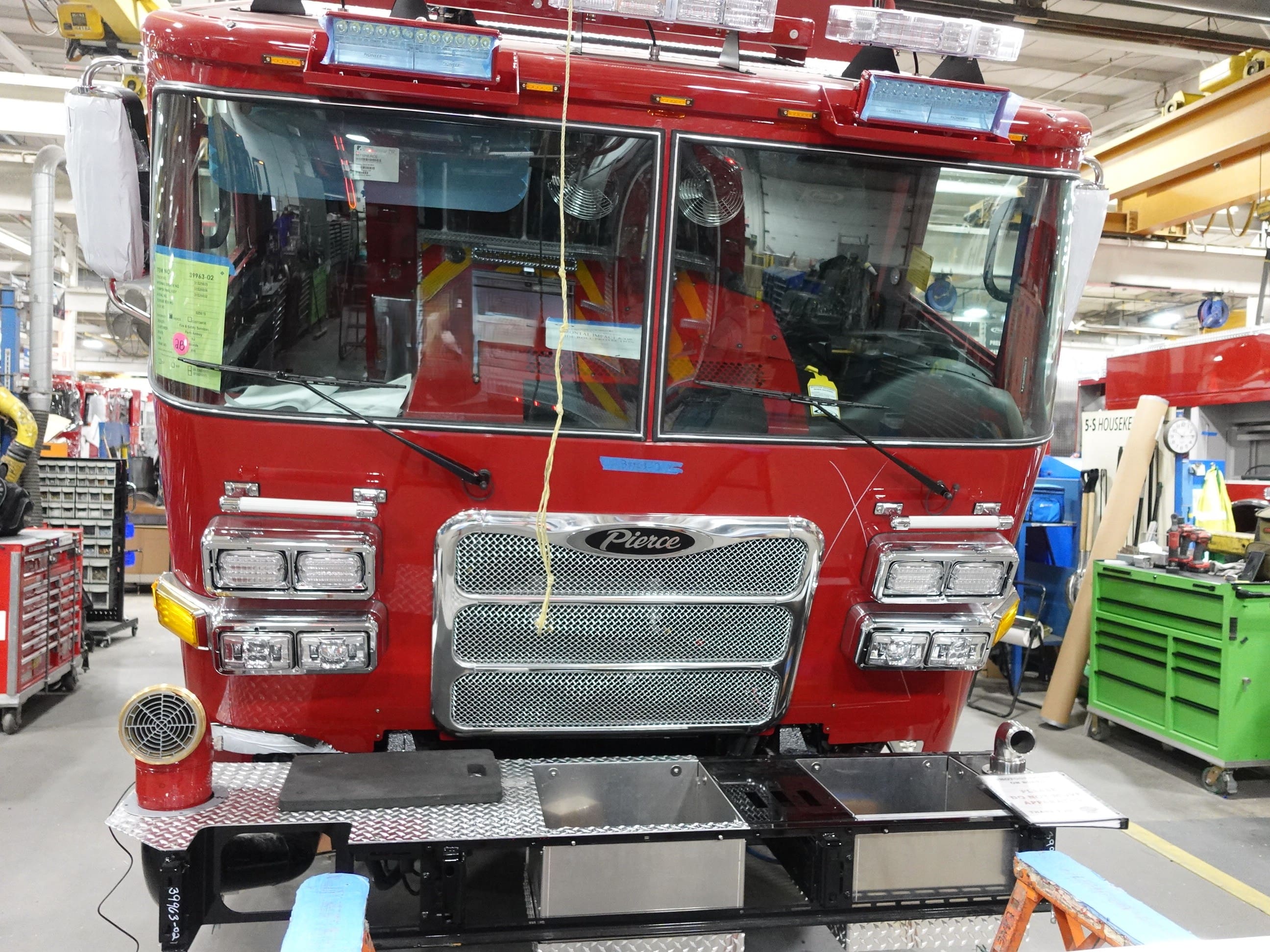

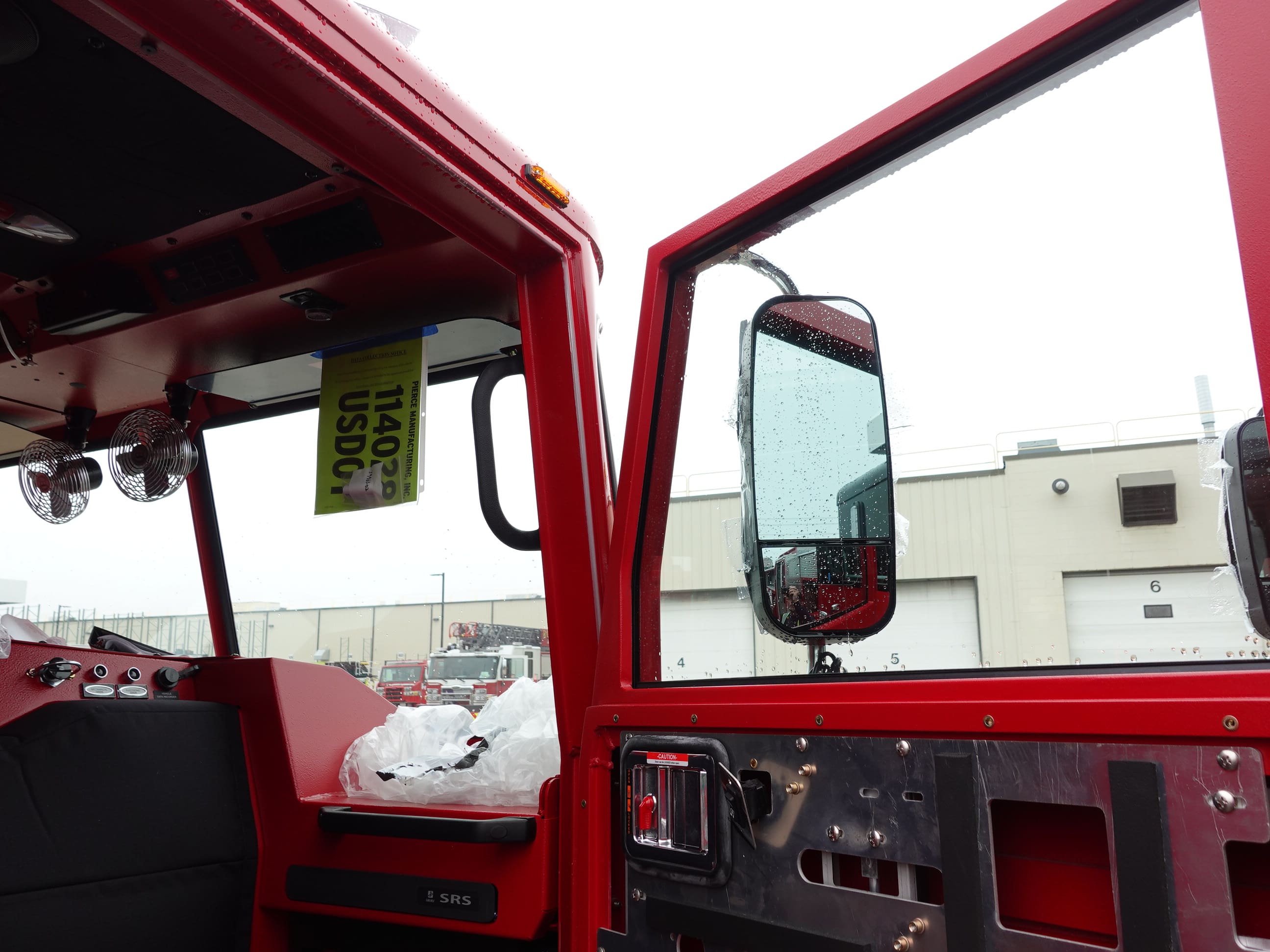

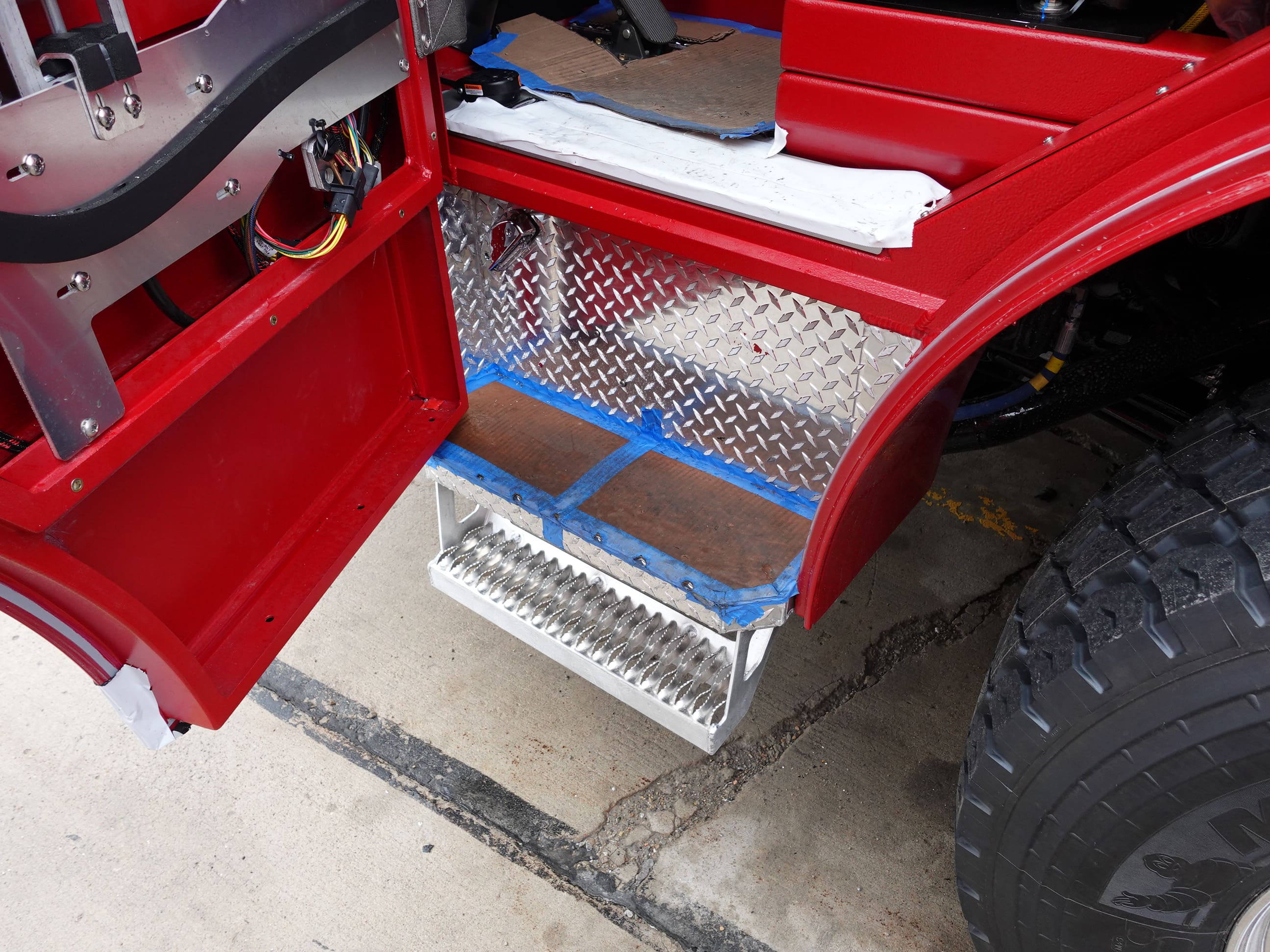

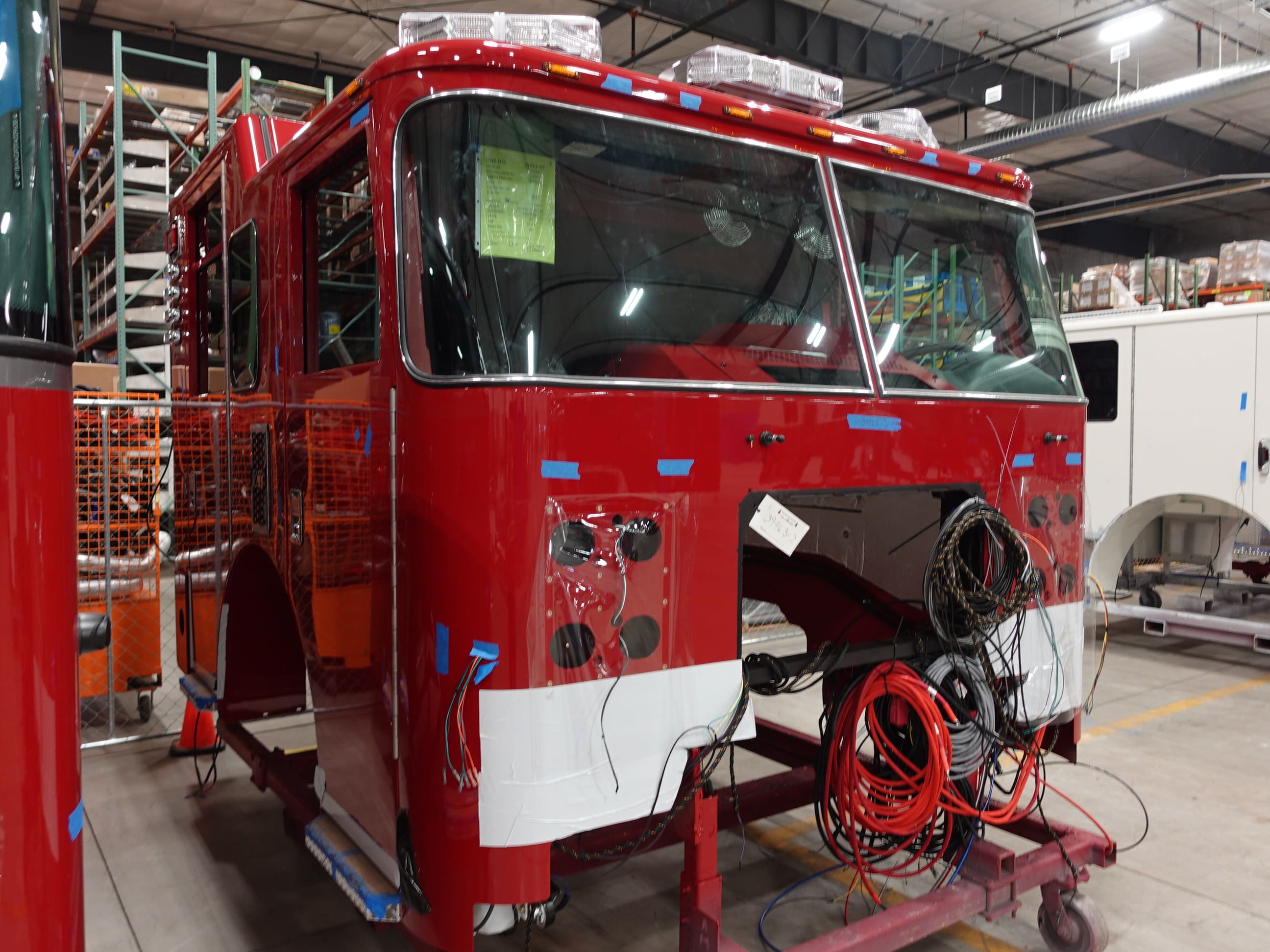

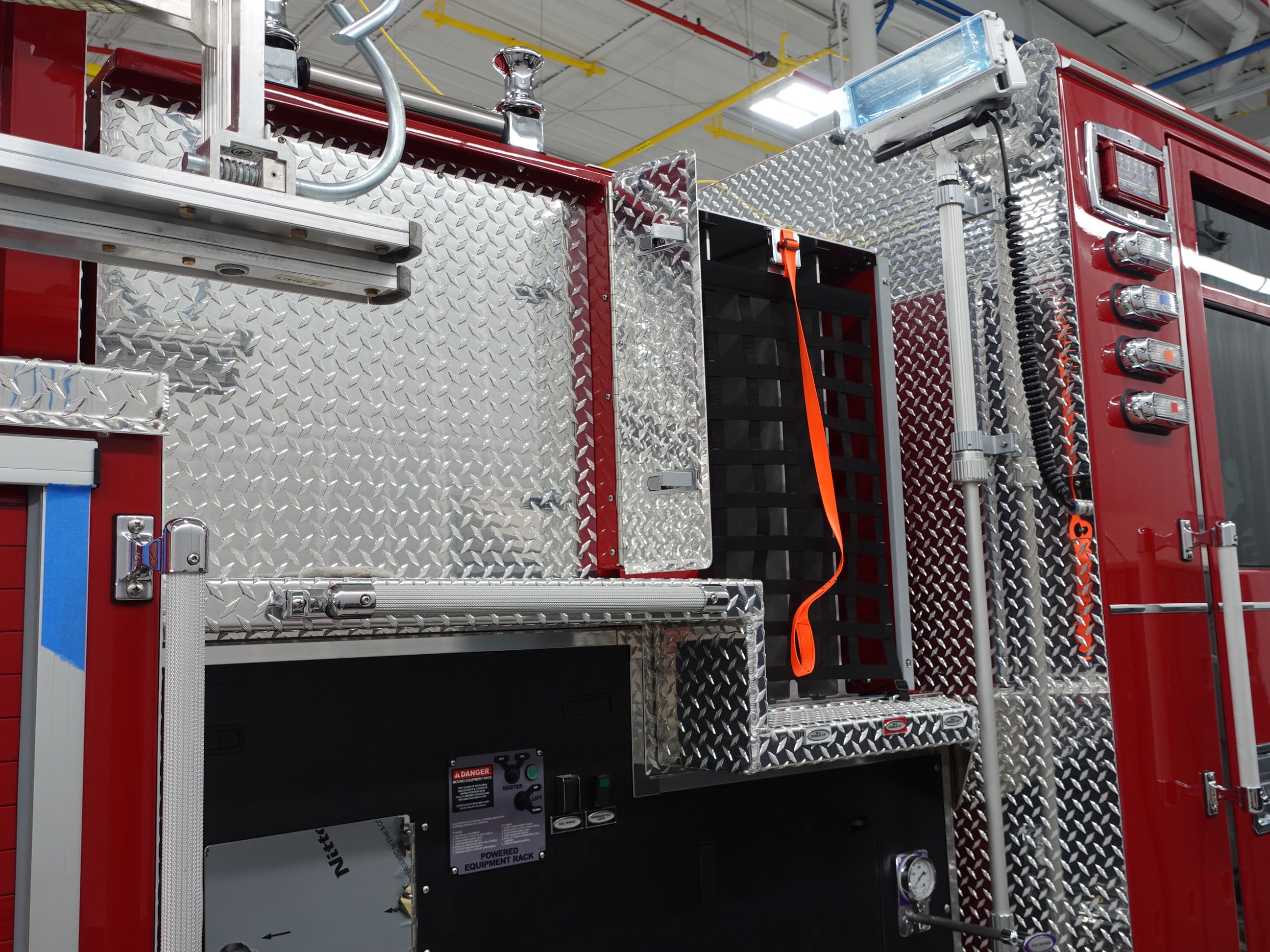

In this report, the cab completed paint then began initial assembly, the frame build continued, the pump house was painted and staged to continue initial assembly, and the body completed the paint process.

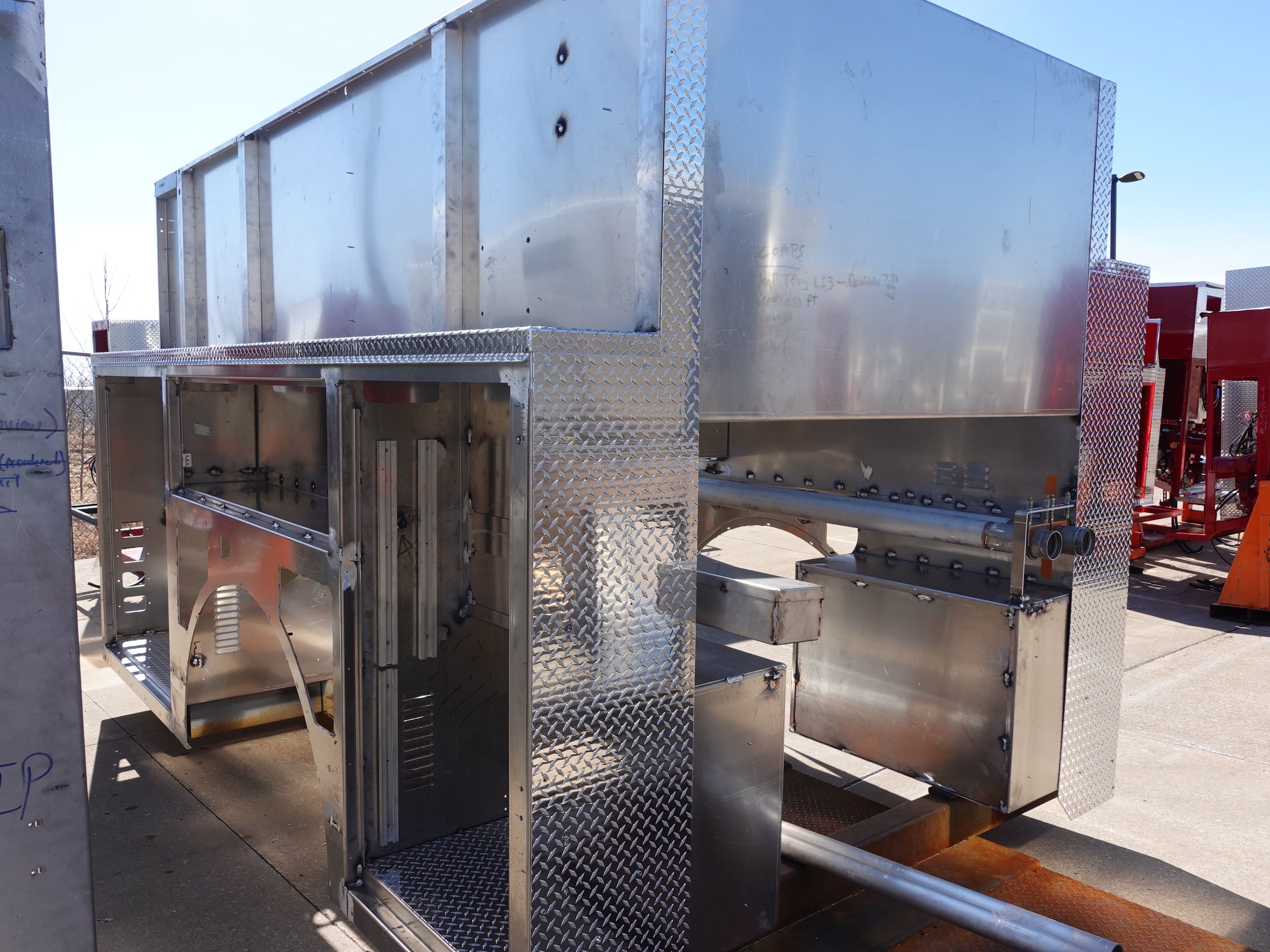

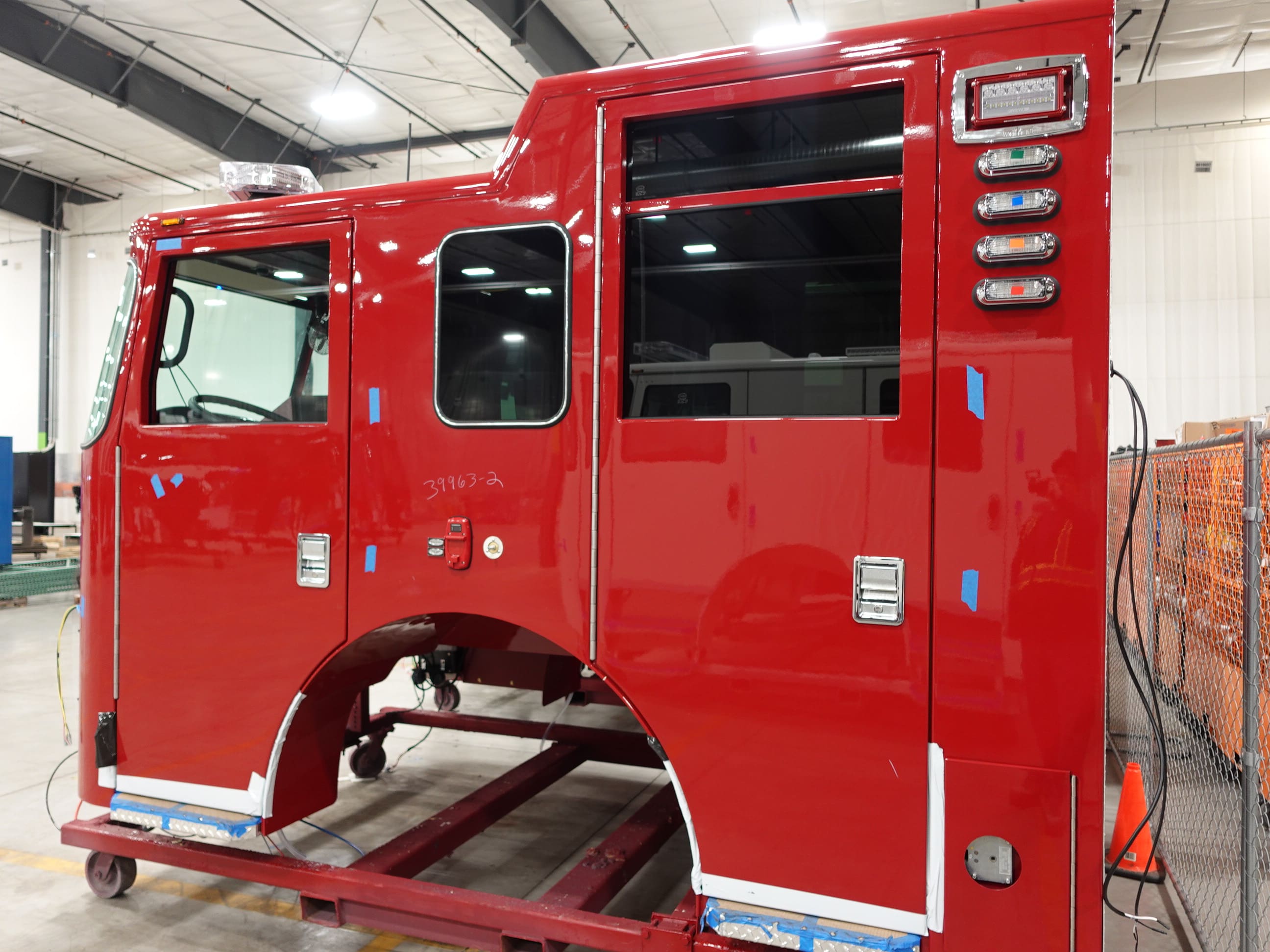

03-13-26

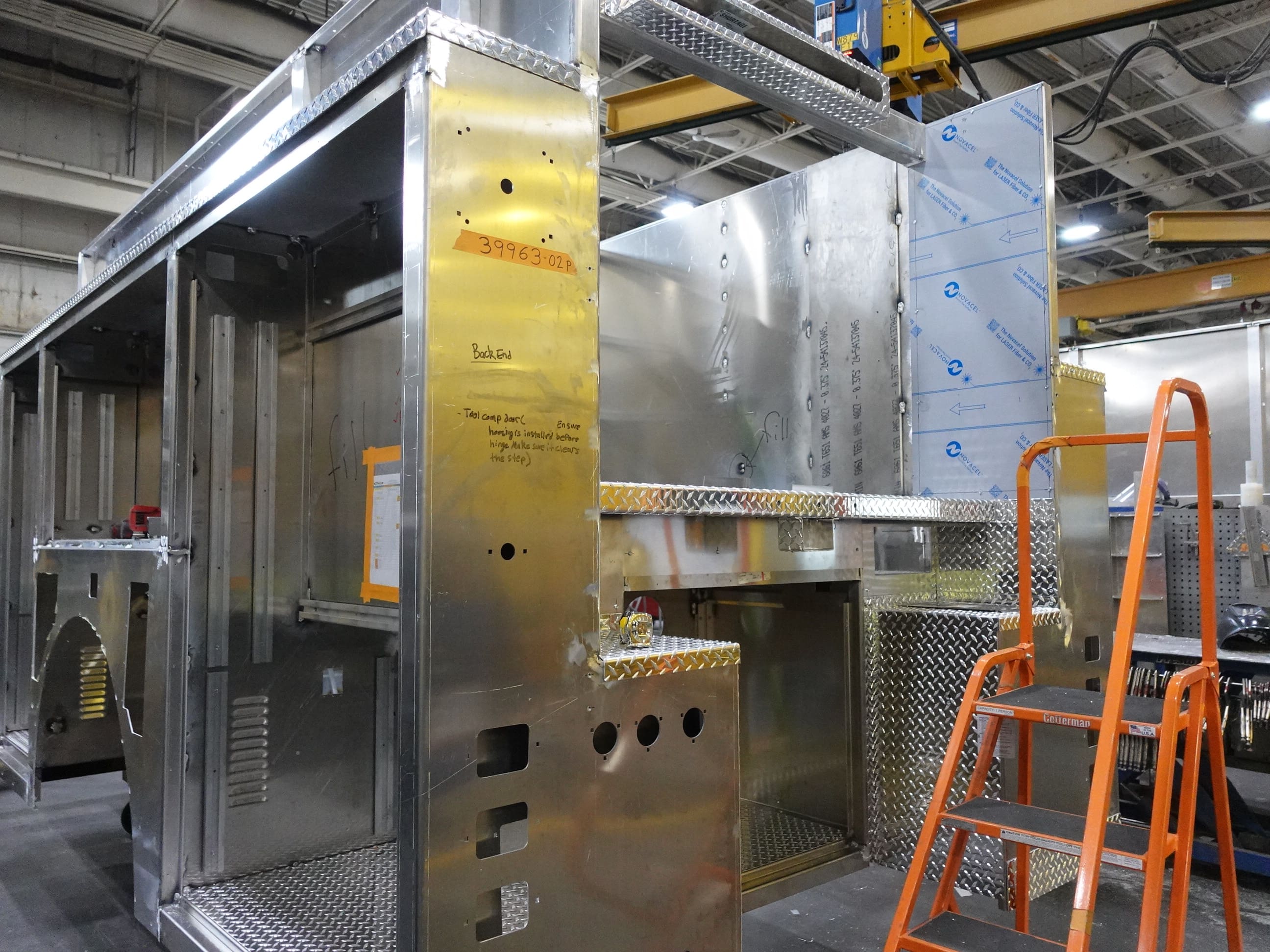

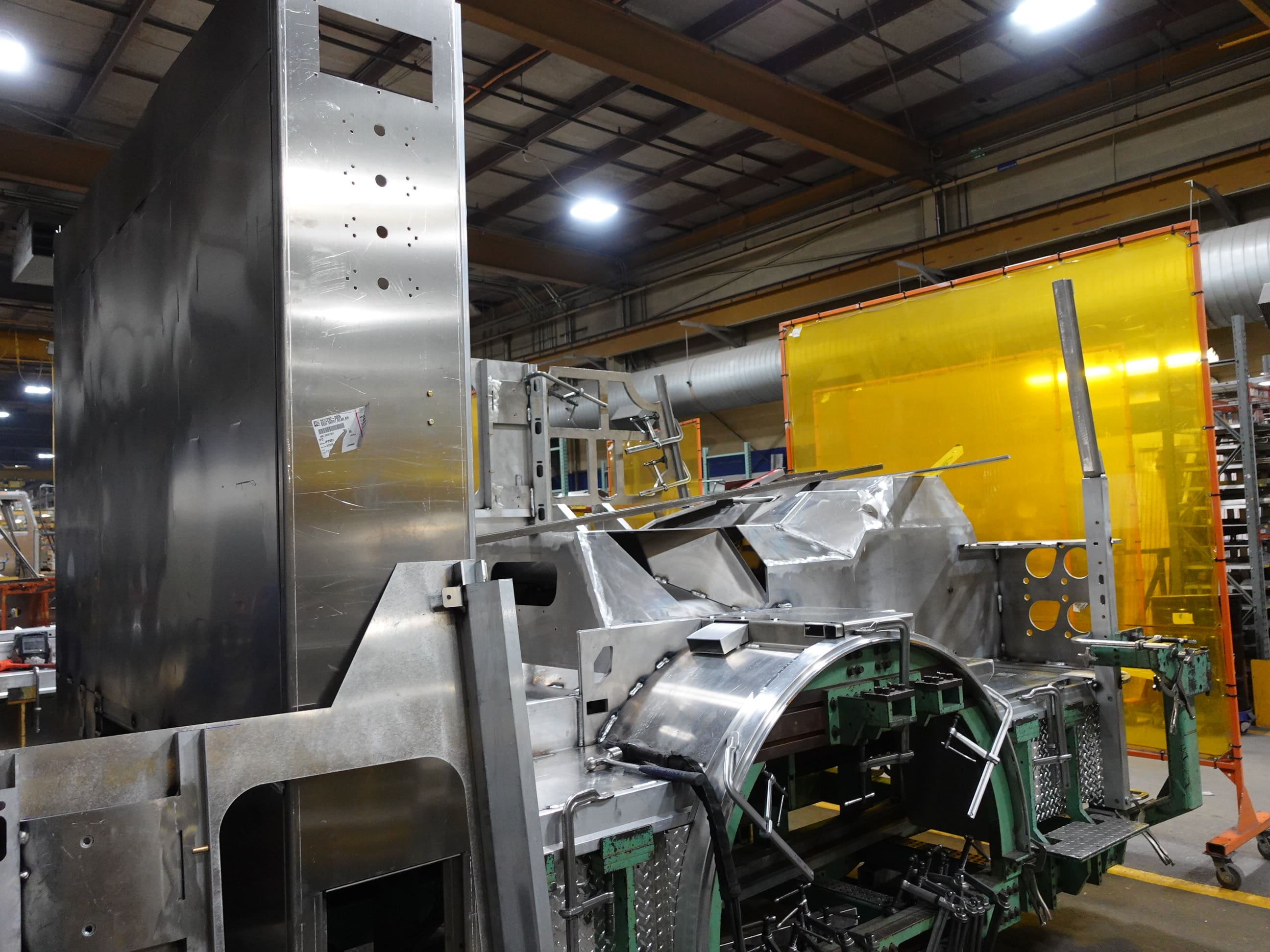

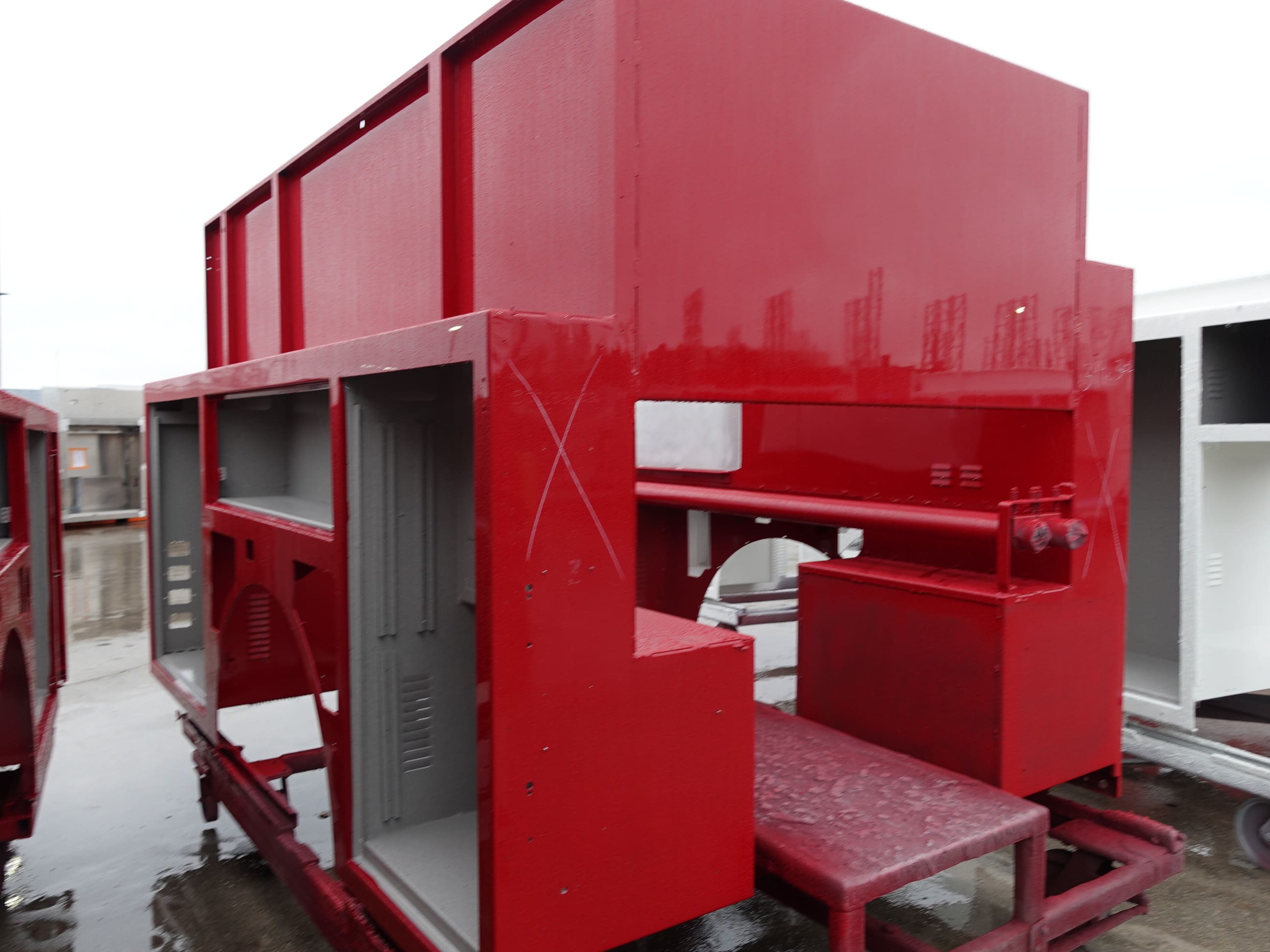

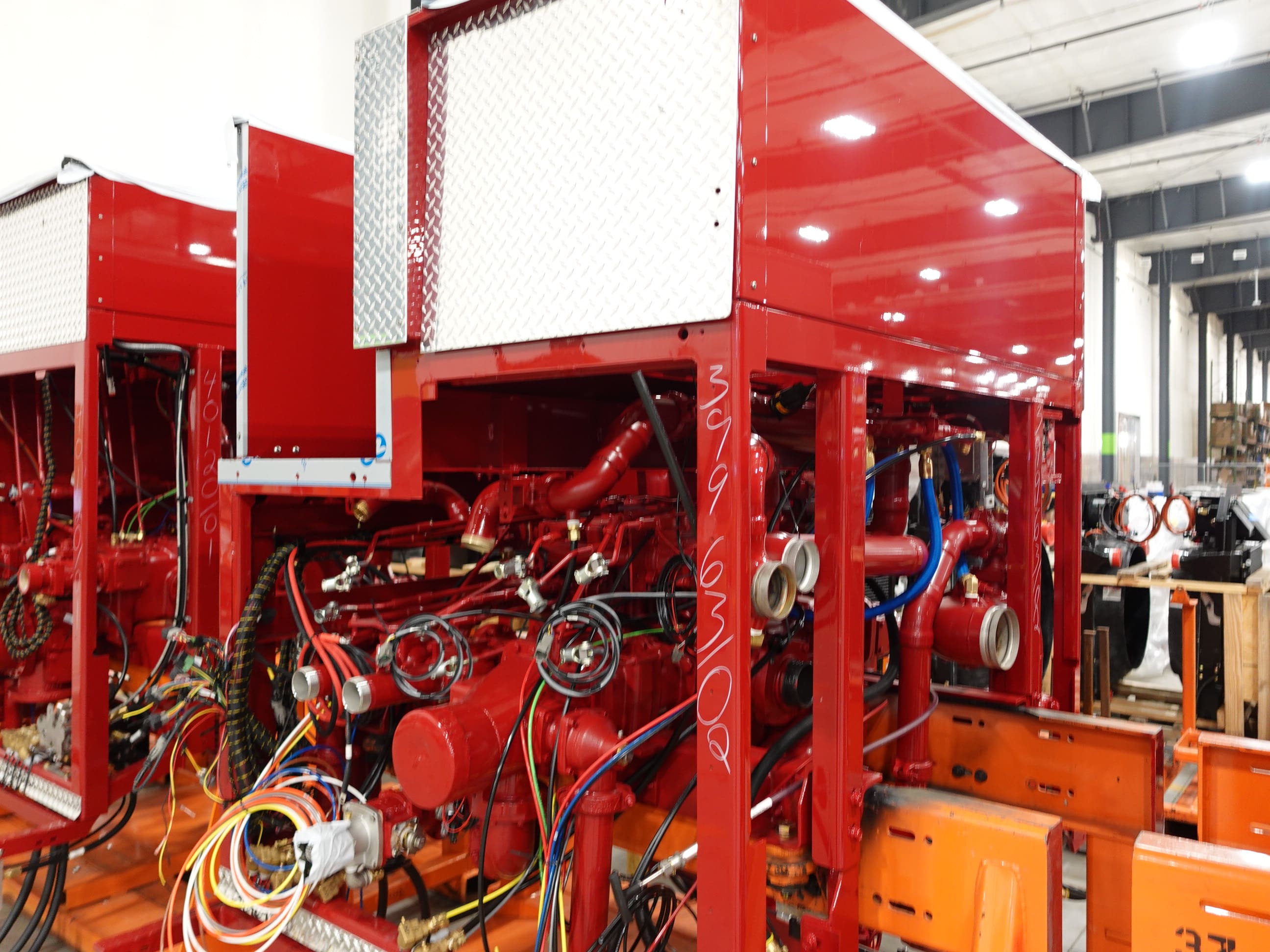

In this report, the cab completed fabrication and began the paint process, the pump house structure was fabricated, and the body completed the fabrication process.

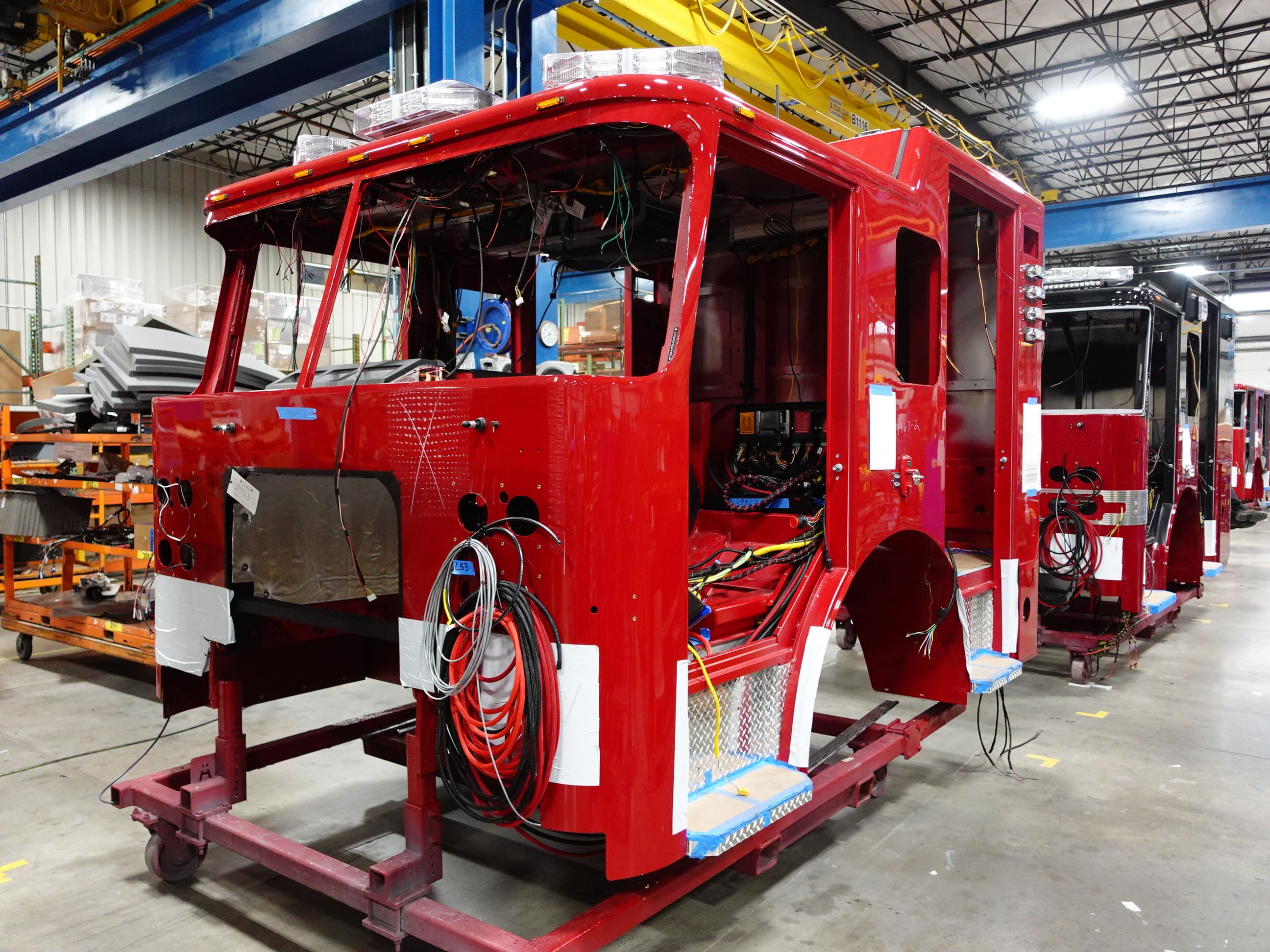

03-06-26

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
