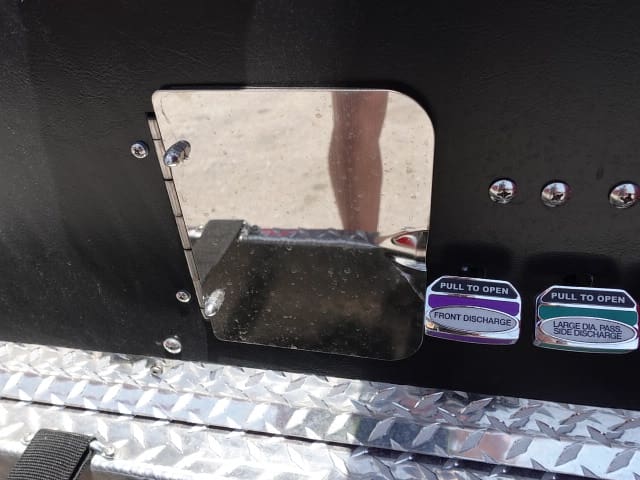

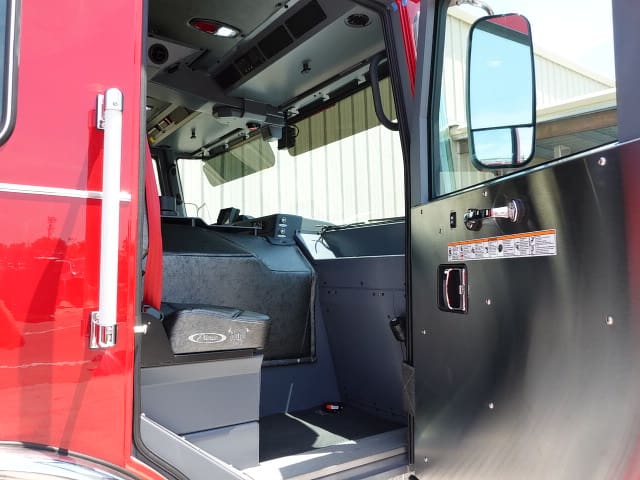

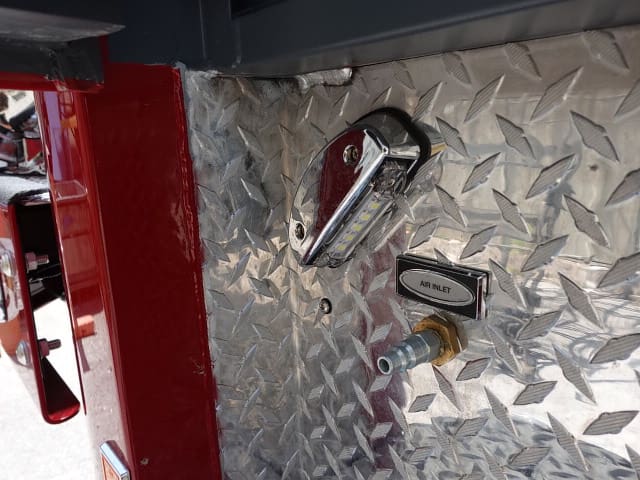

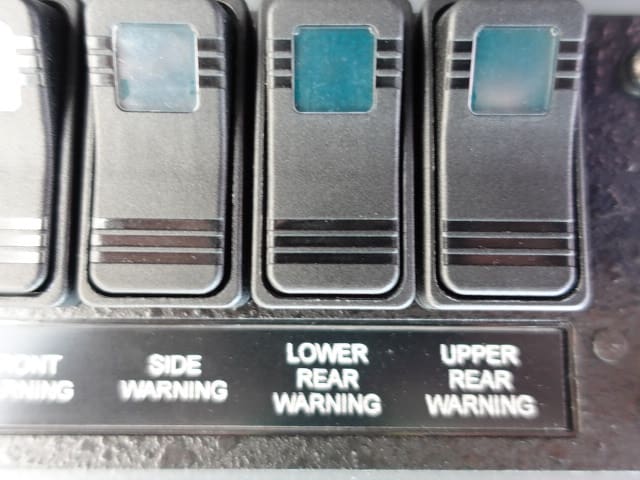

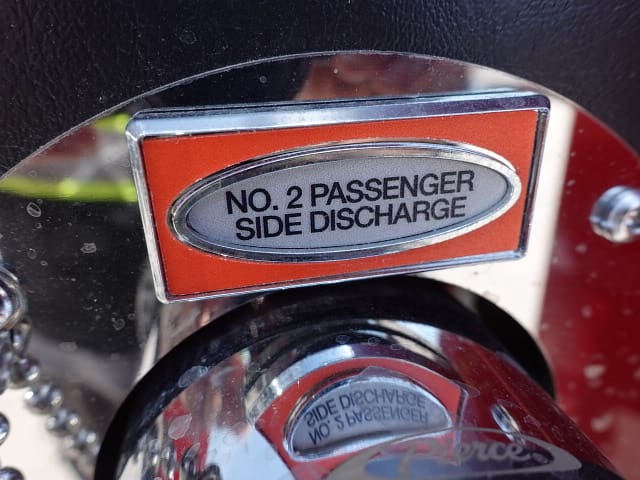

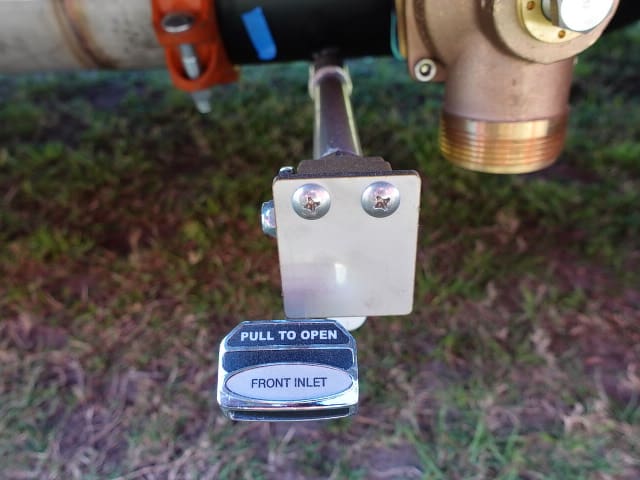

04-25-25

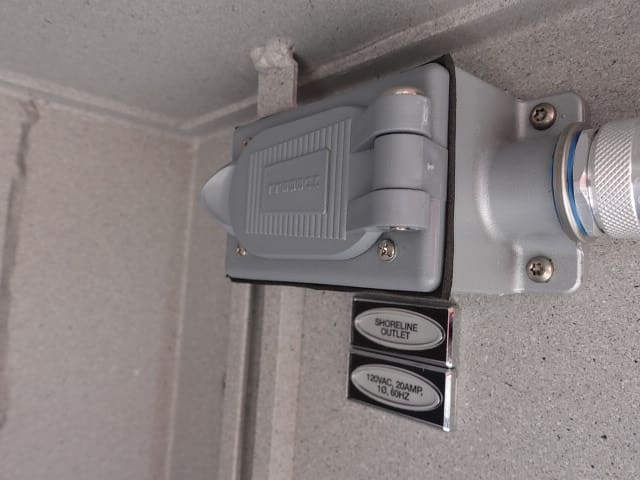

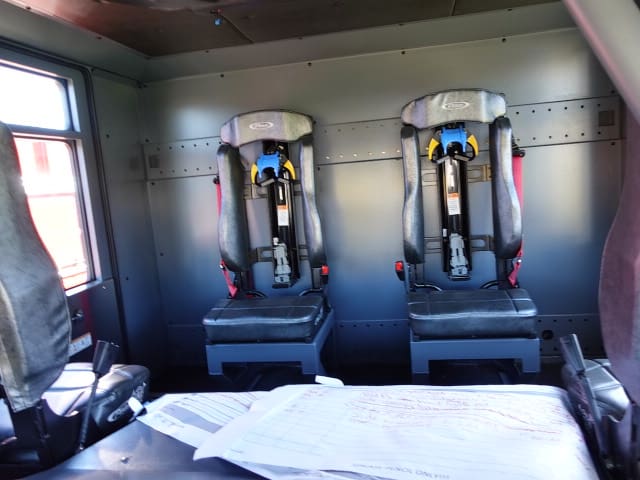

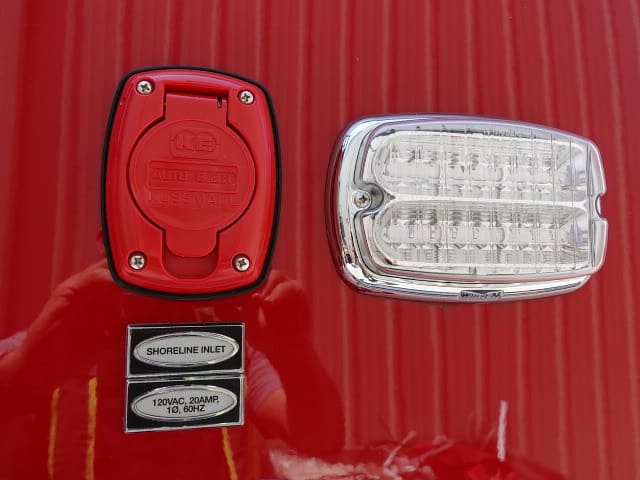

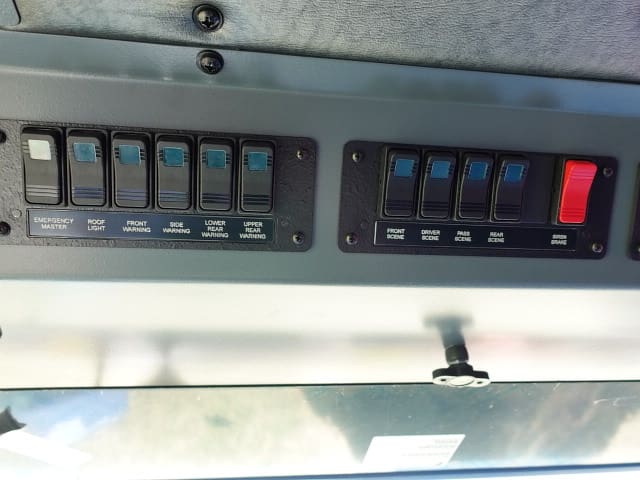

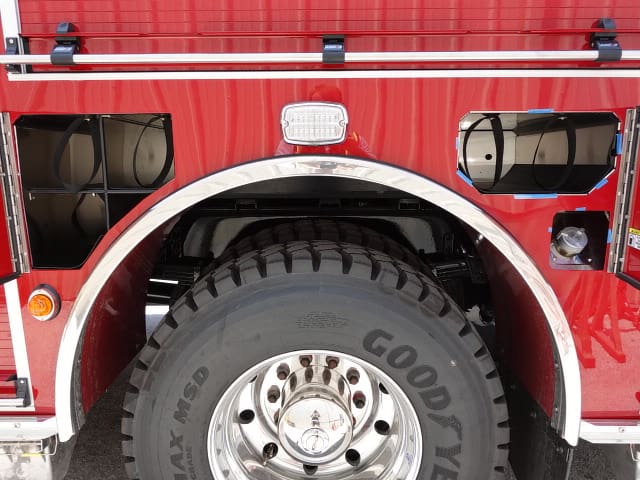

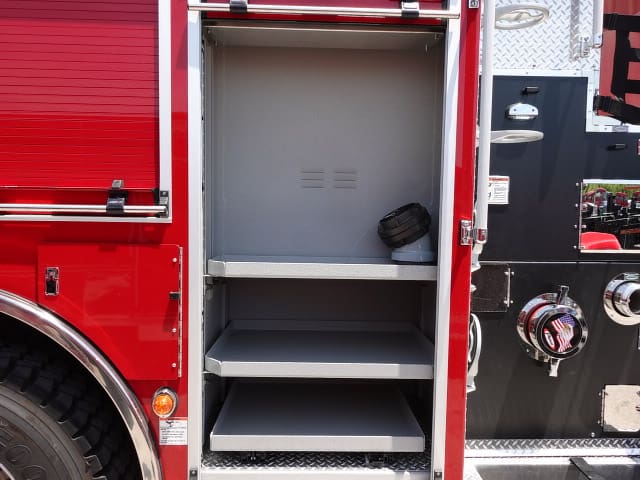

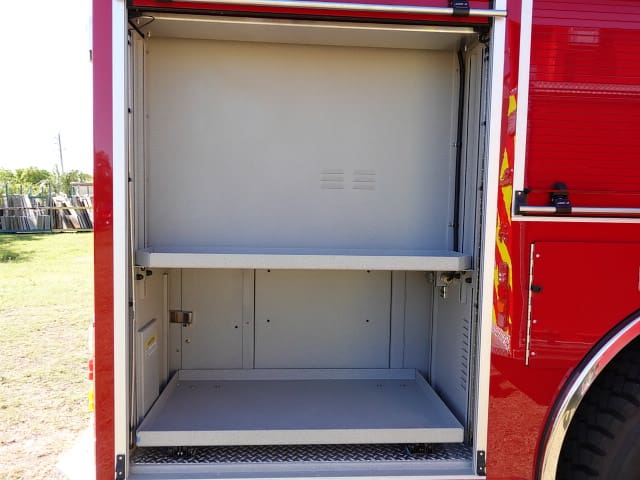

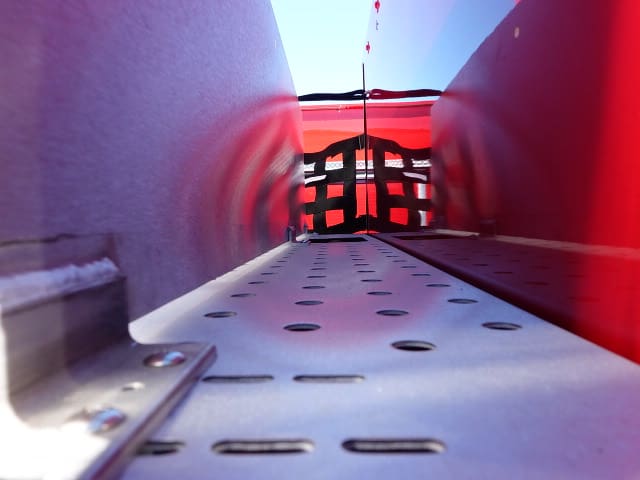

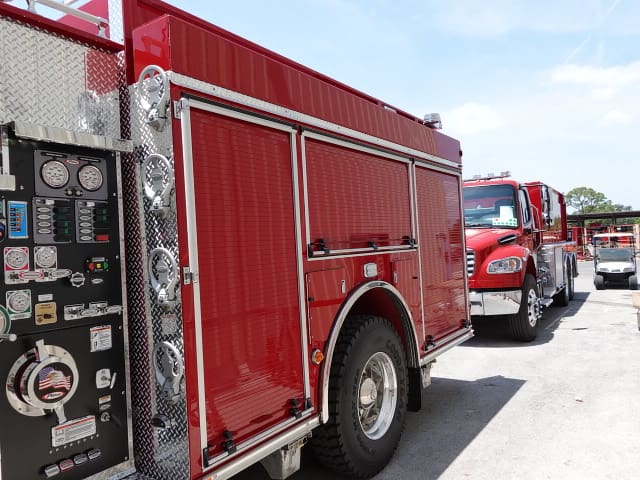

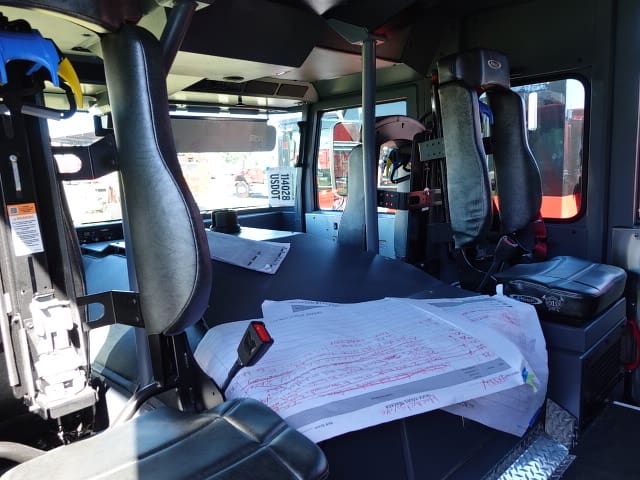

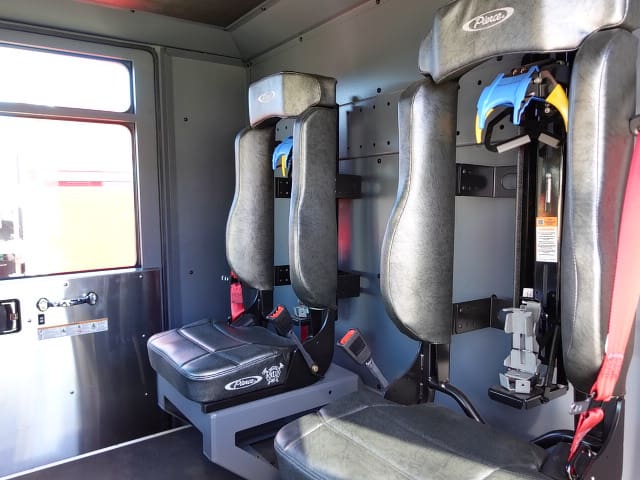

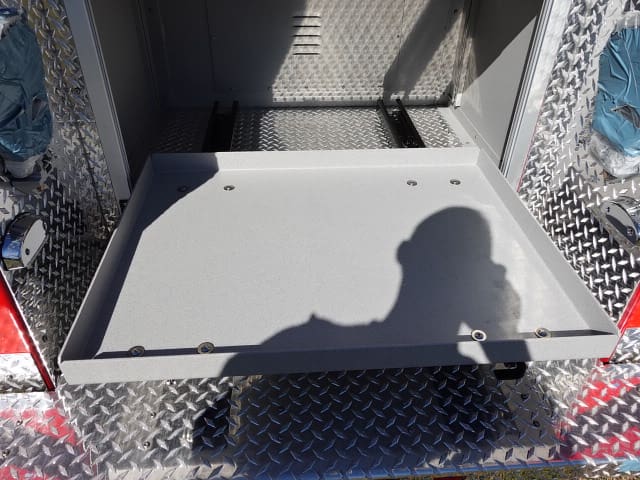

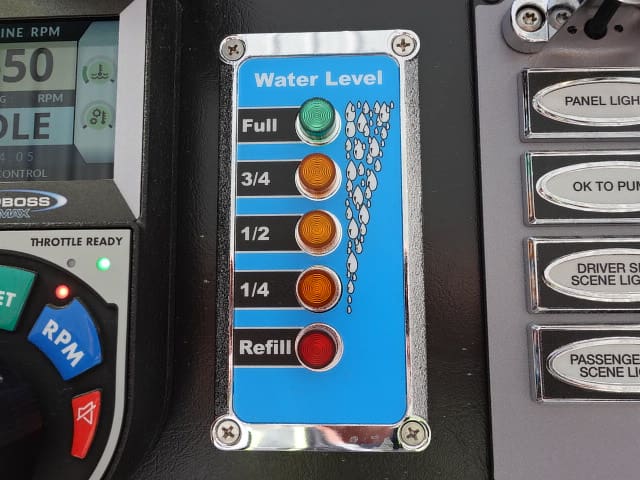

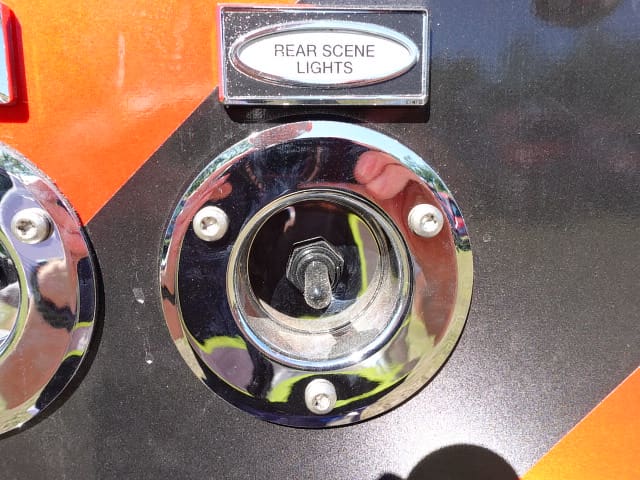

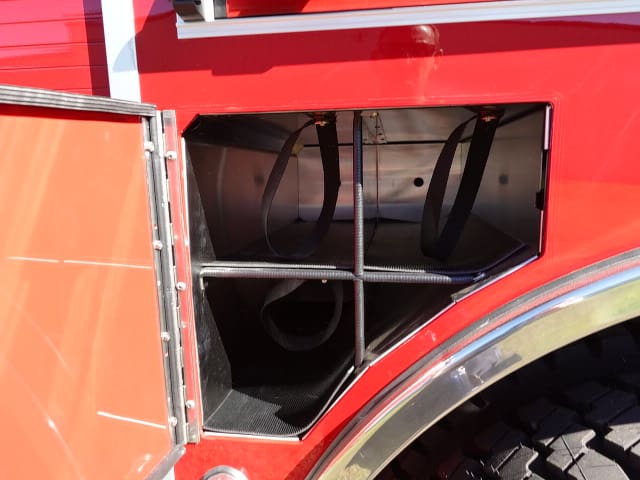

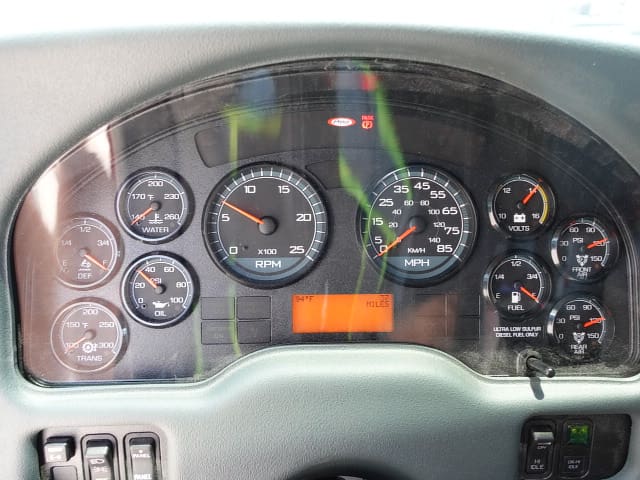

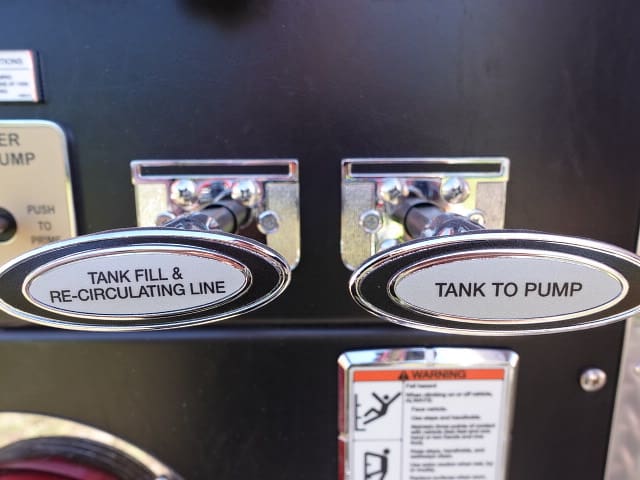

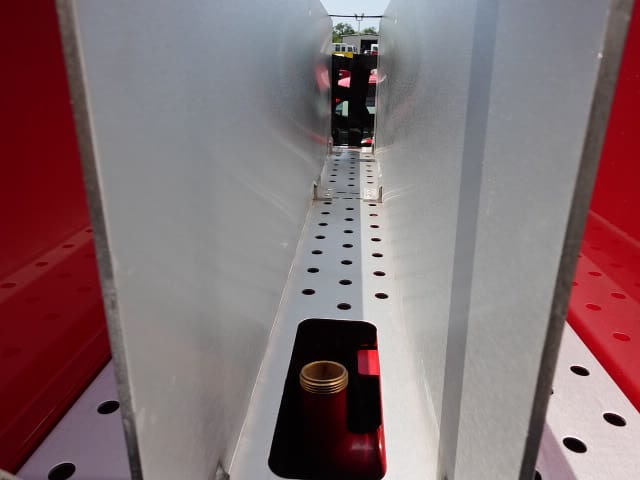

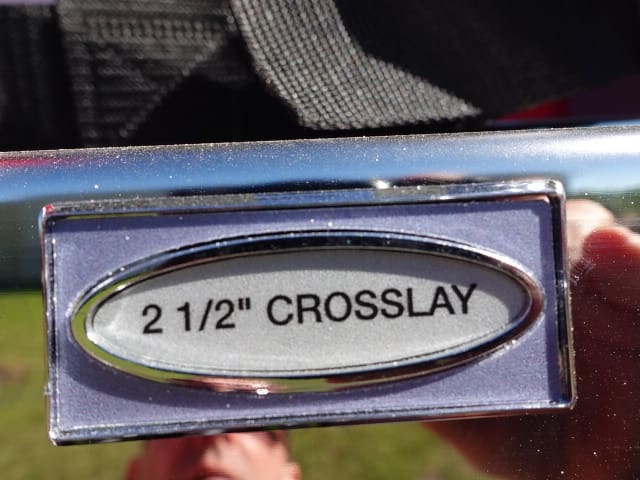

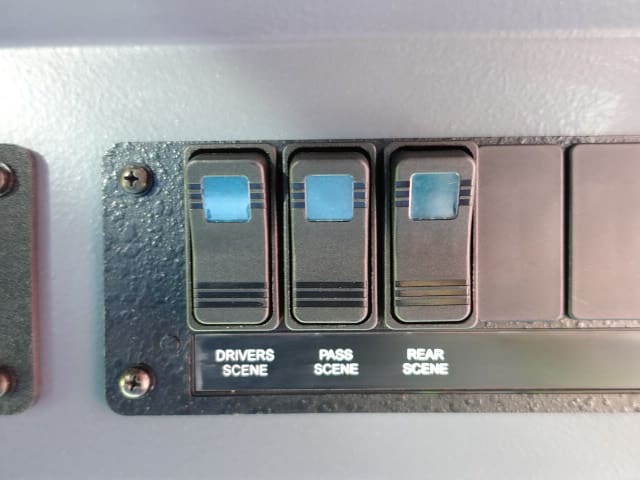

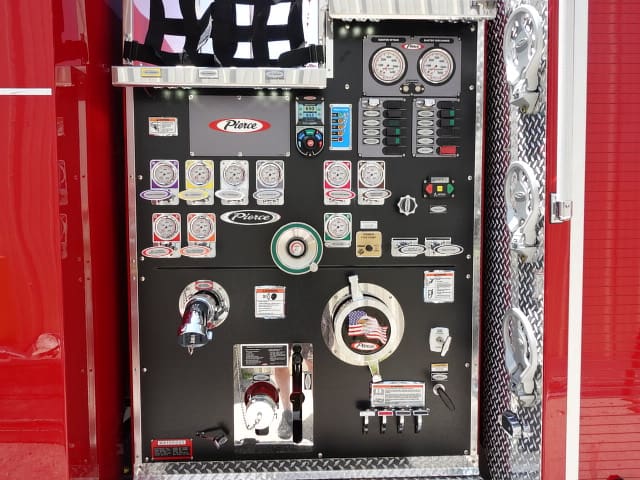

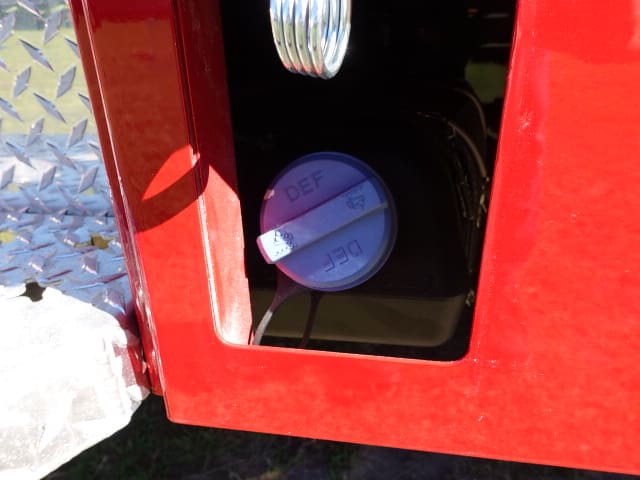

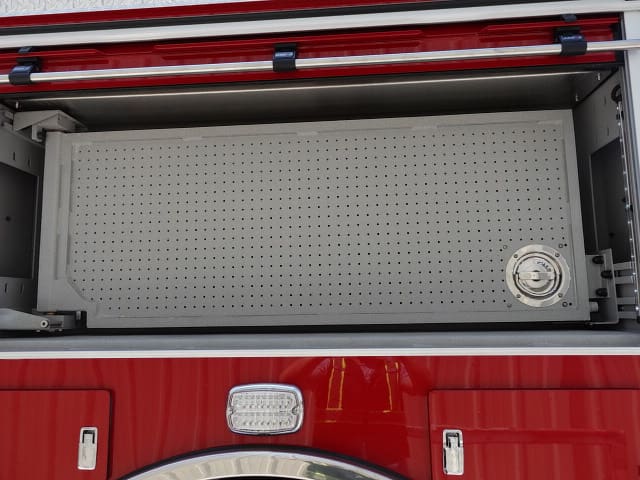

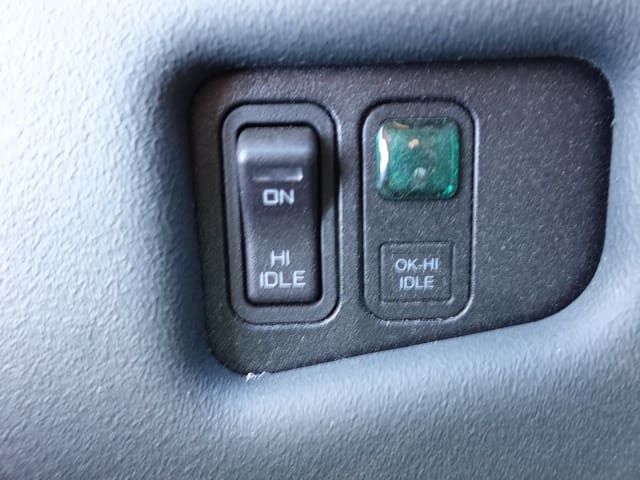

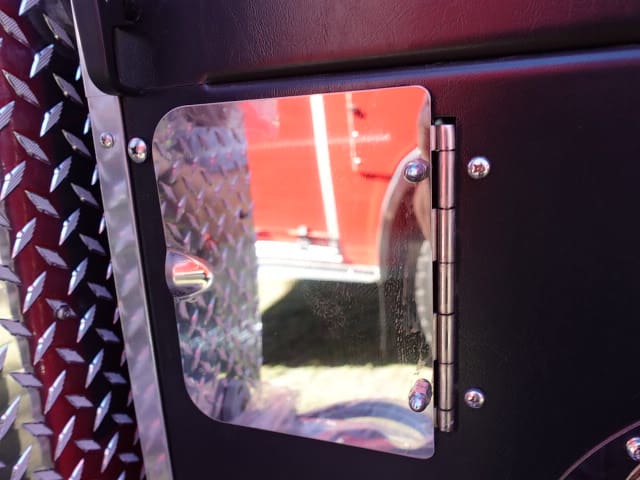

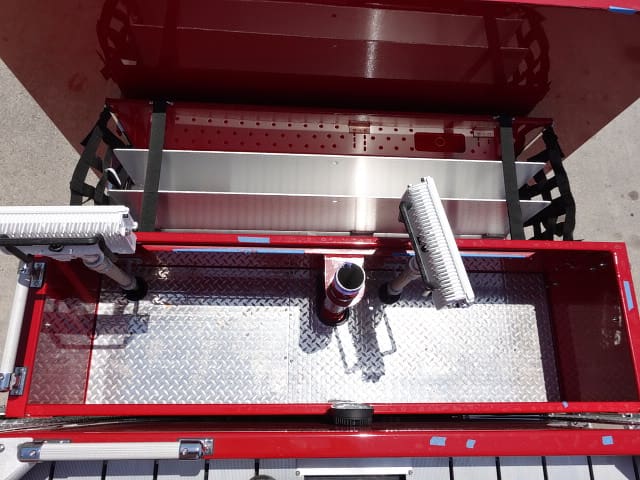

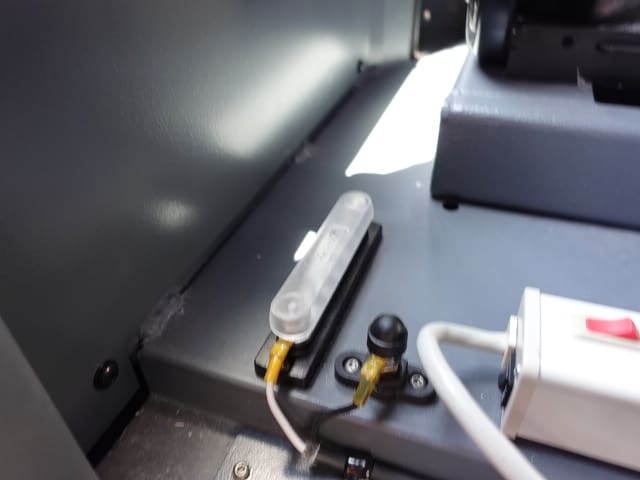

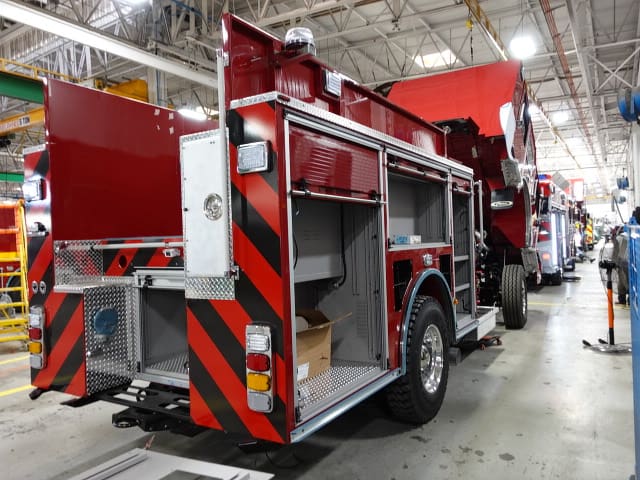

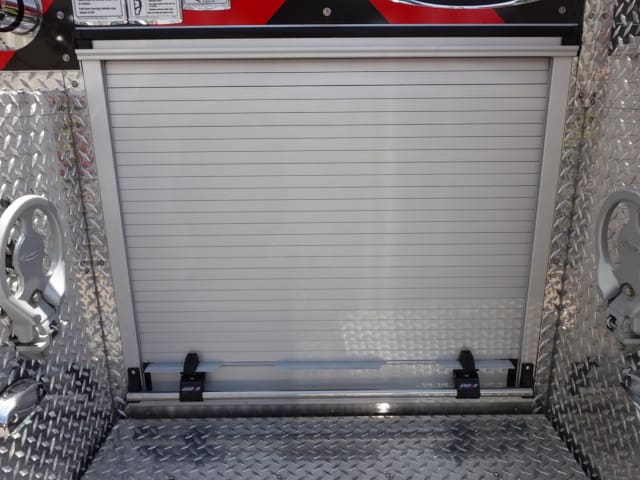

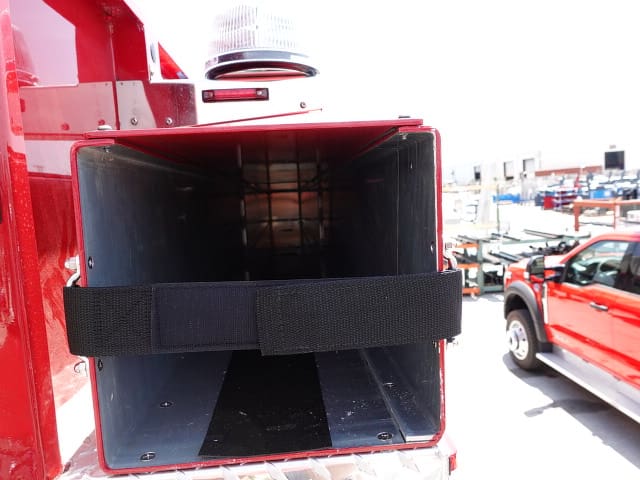

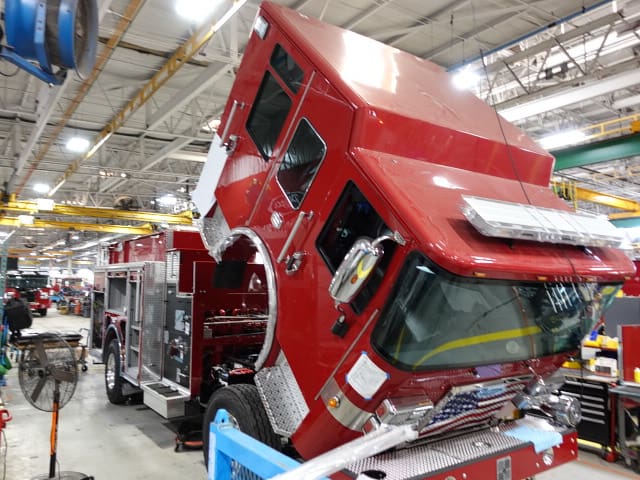

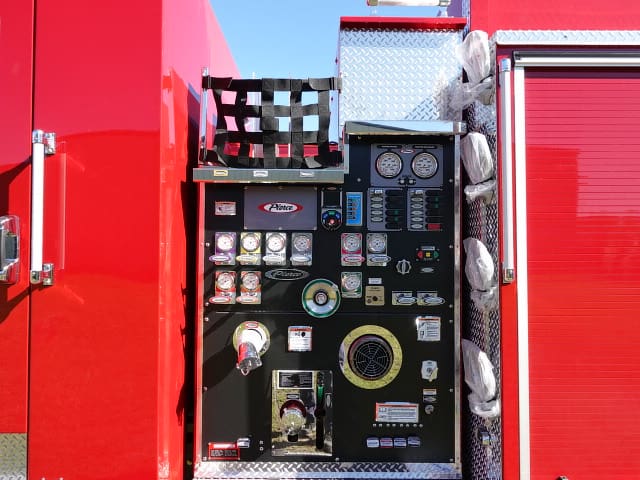

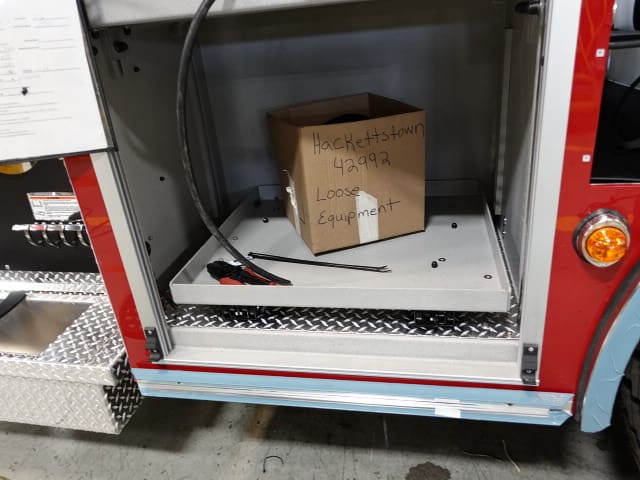

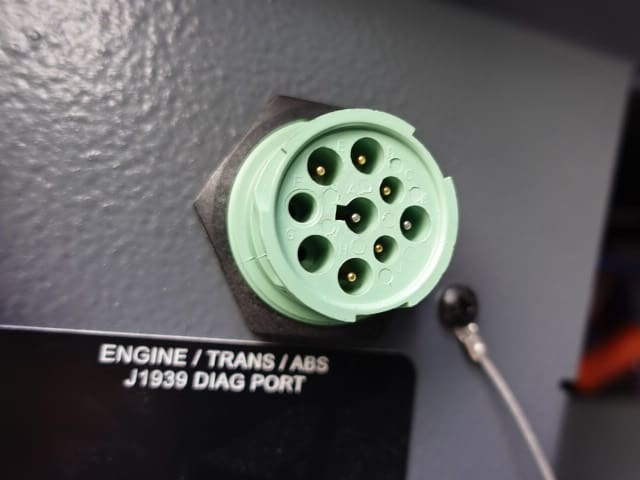

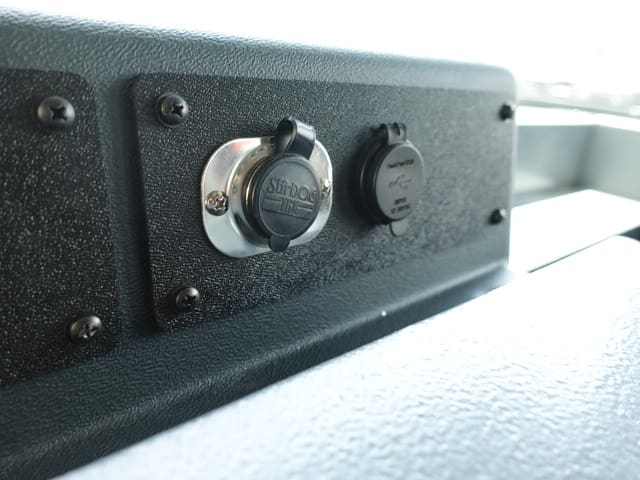

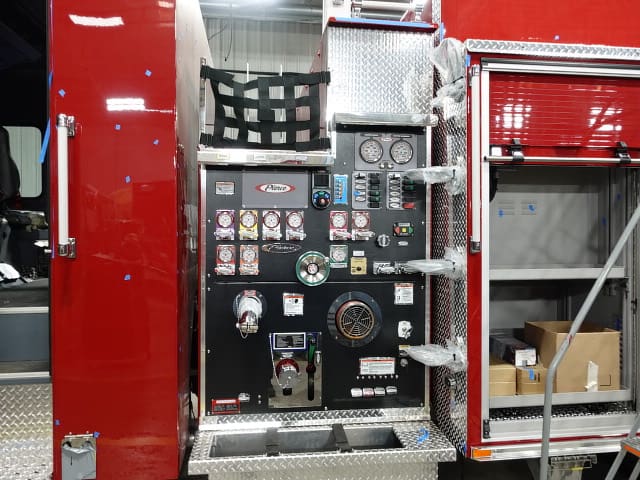

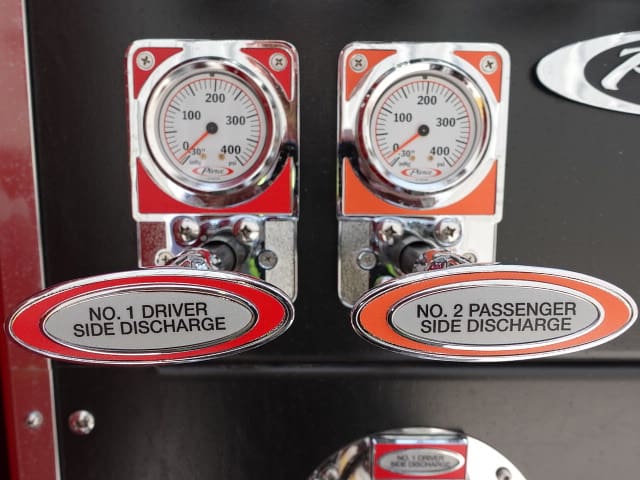

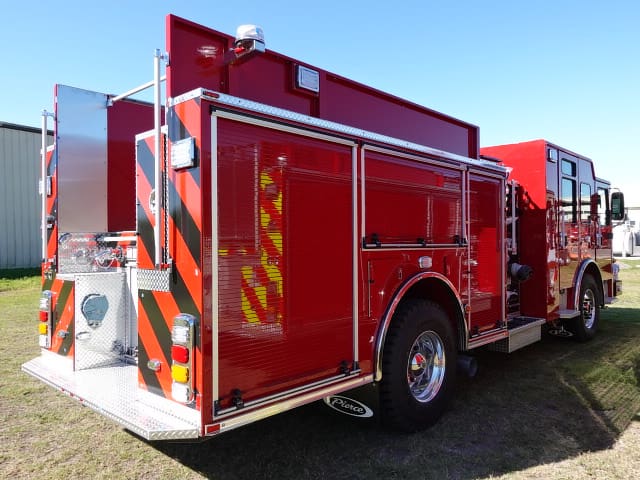

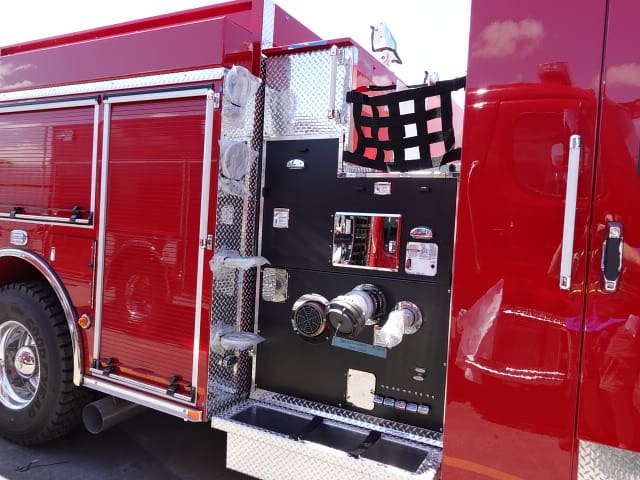

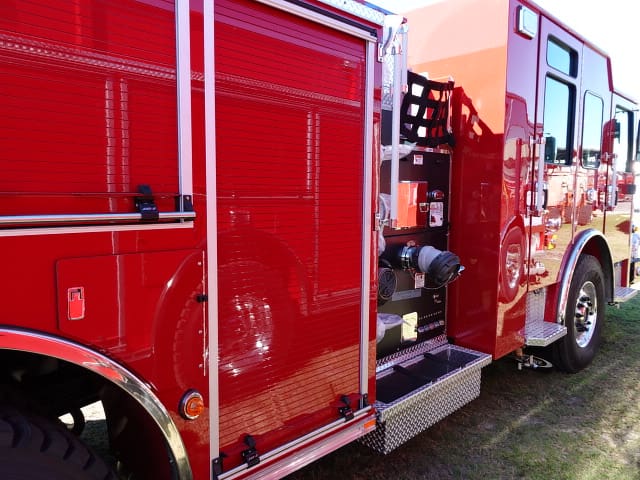

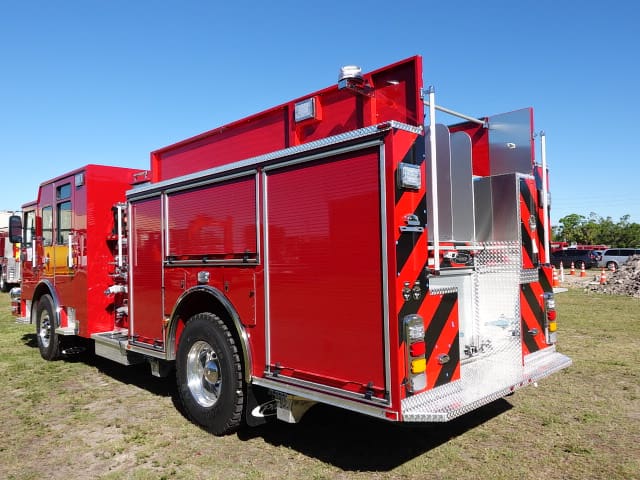

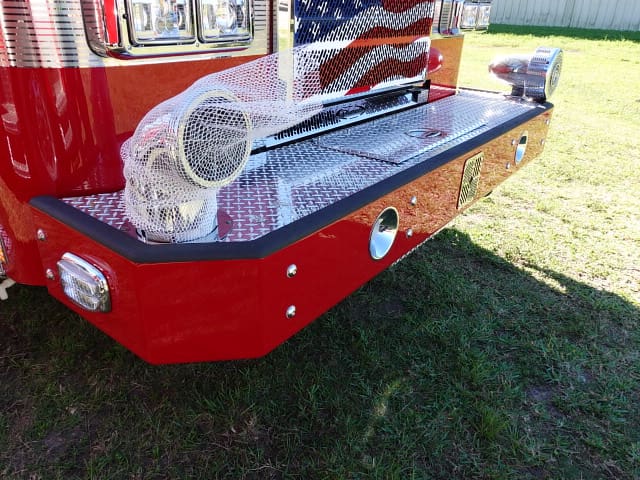

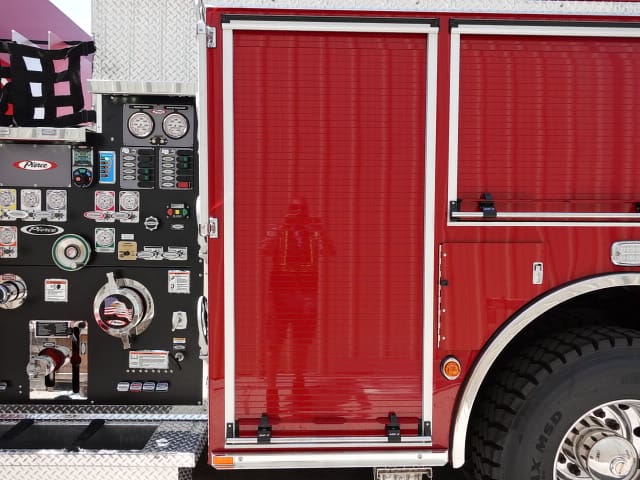

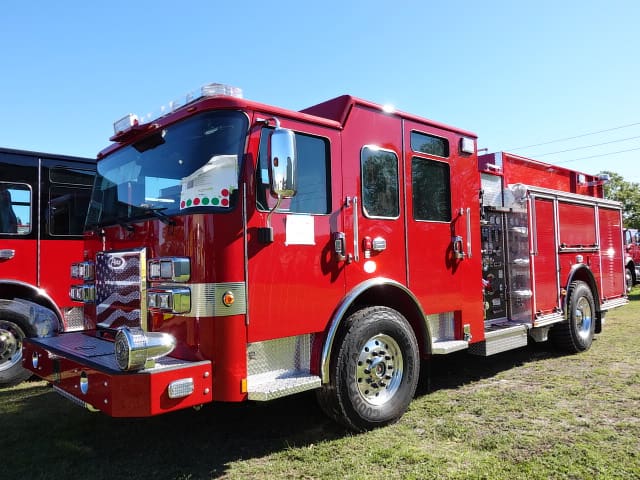

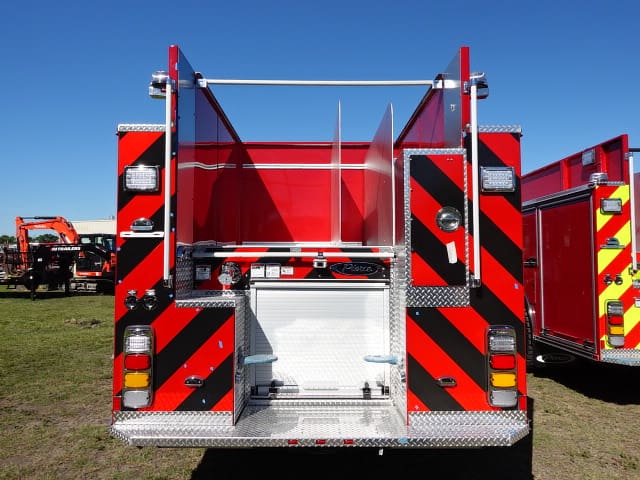

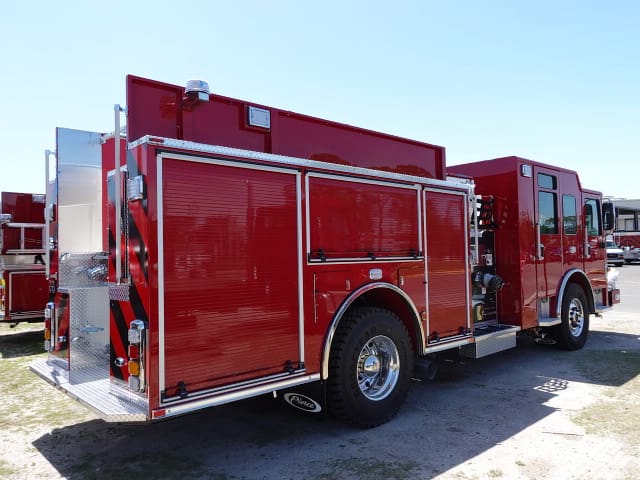

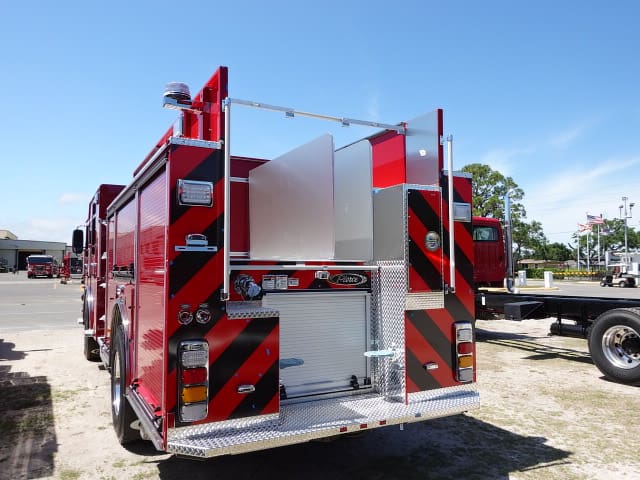

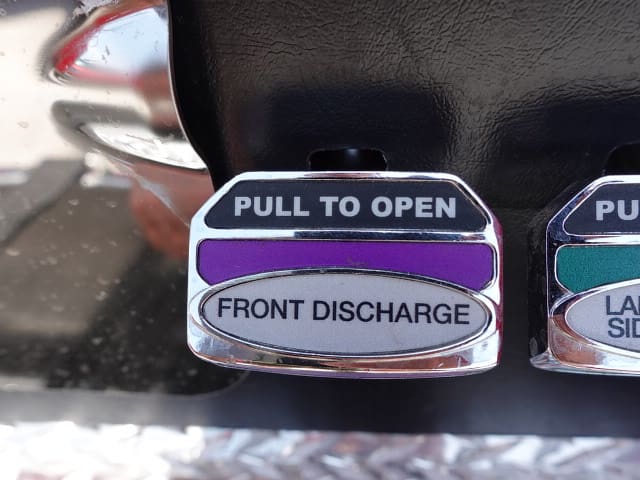

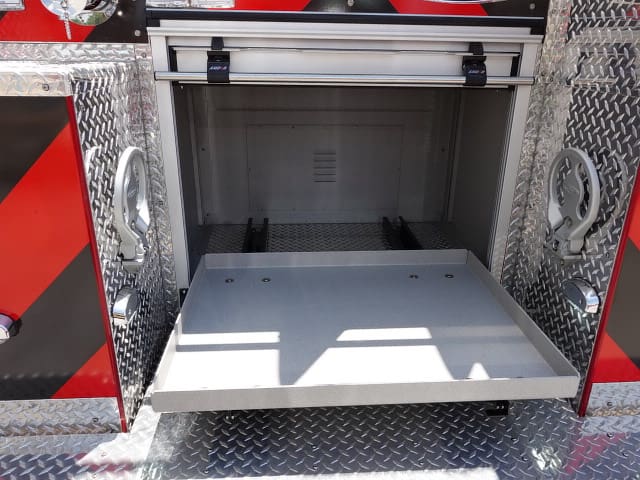

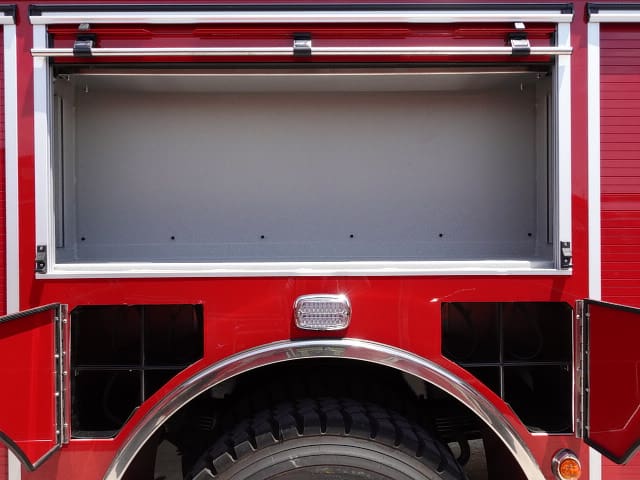

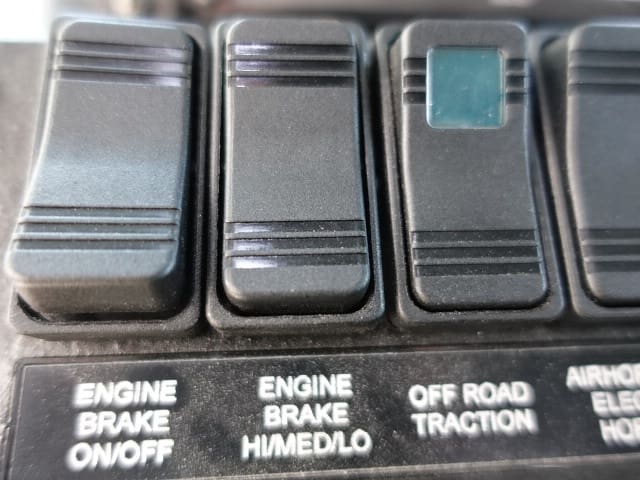

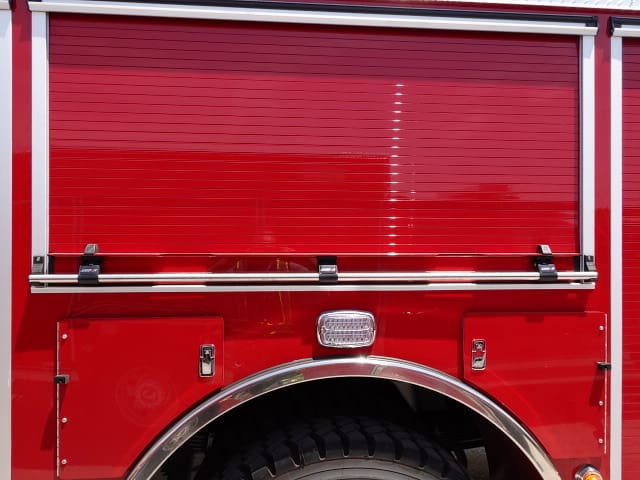

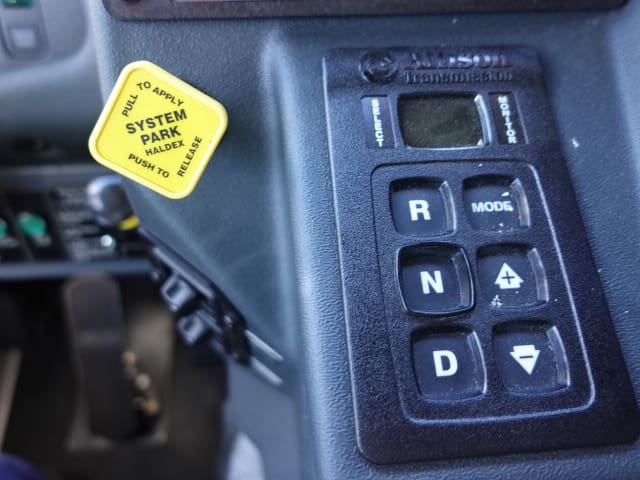

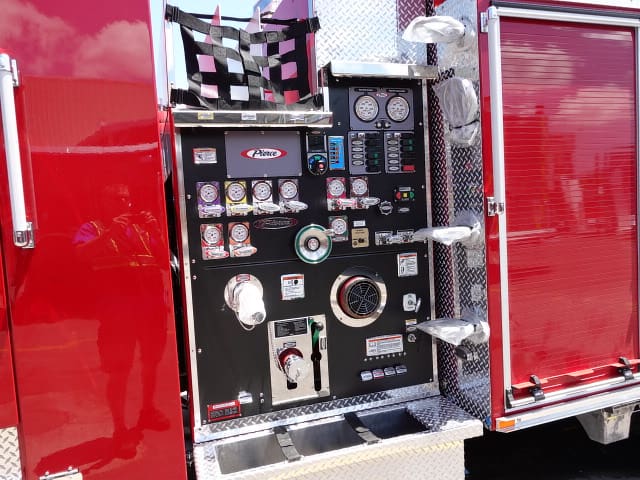

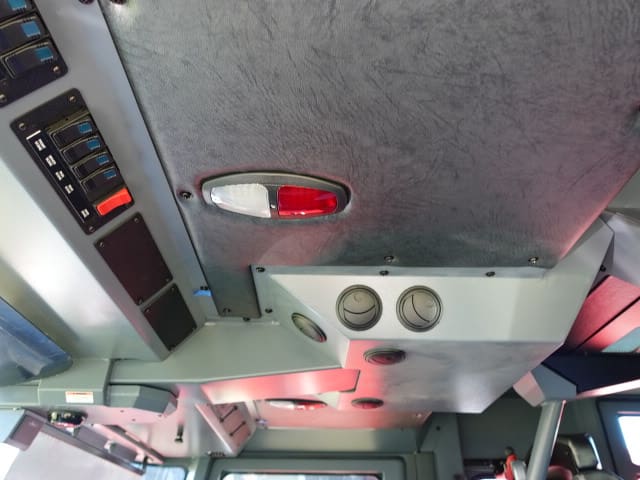

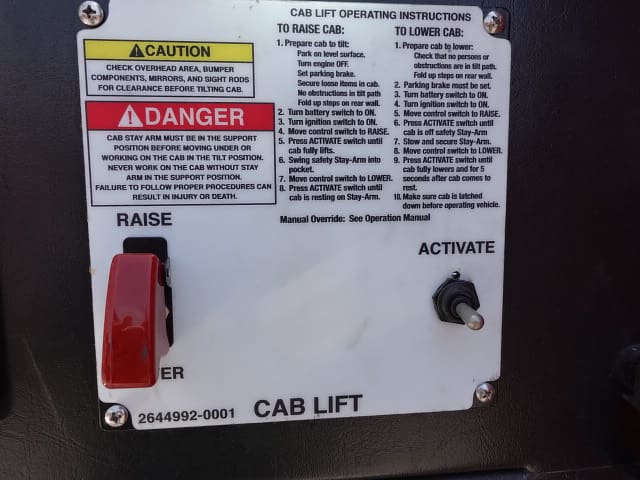

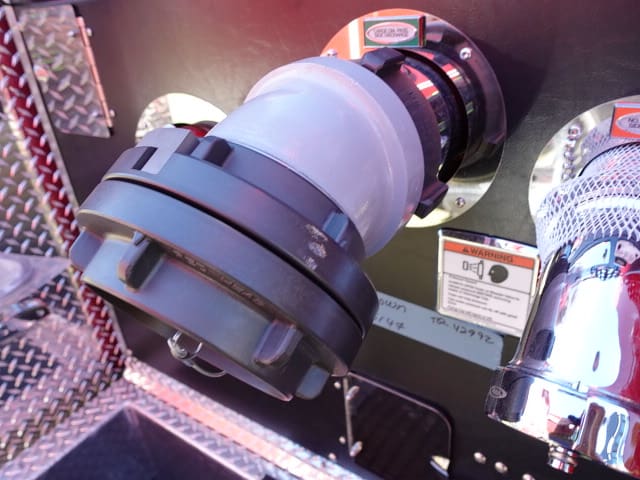

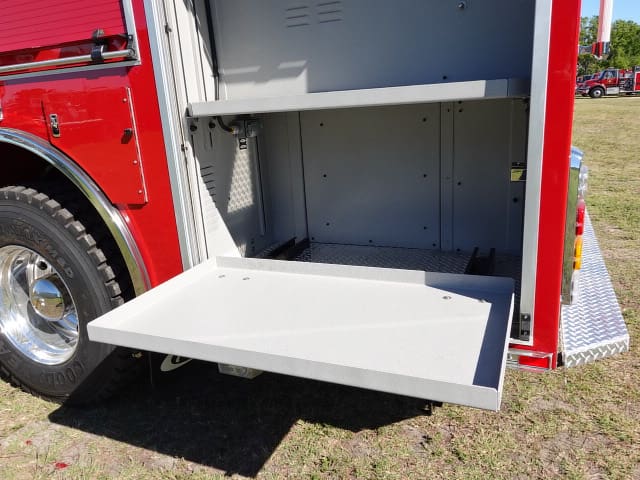

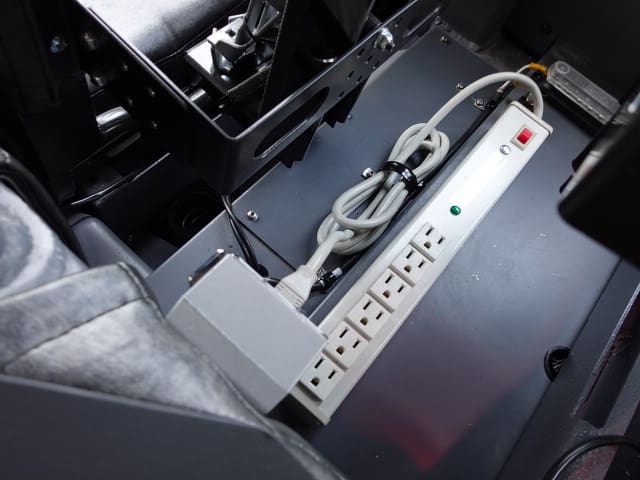

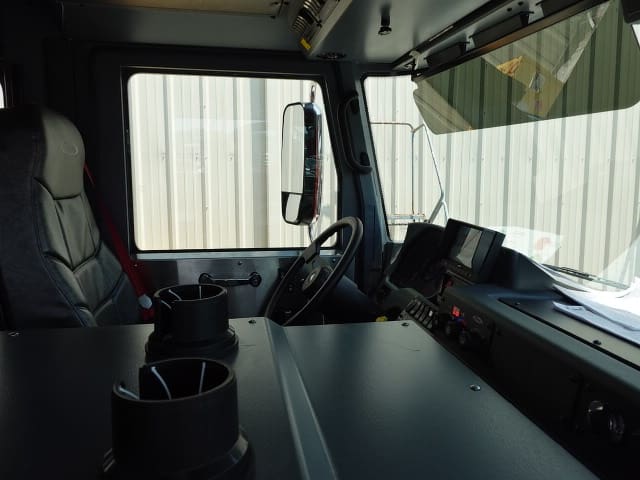

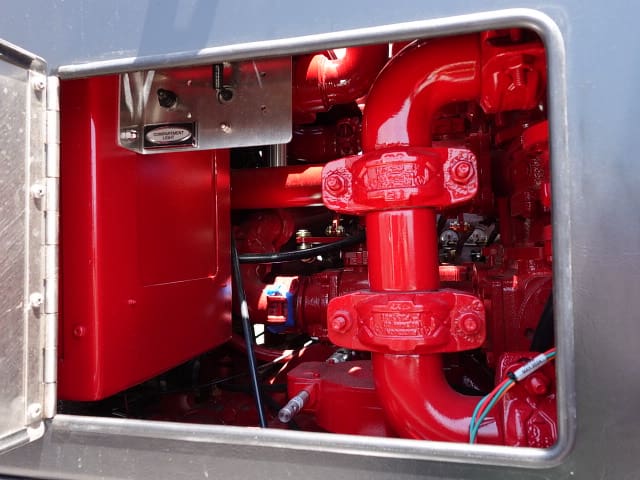

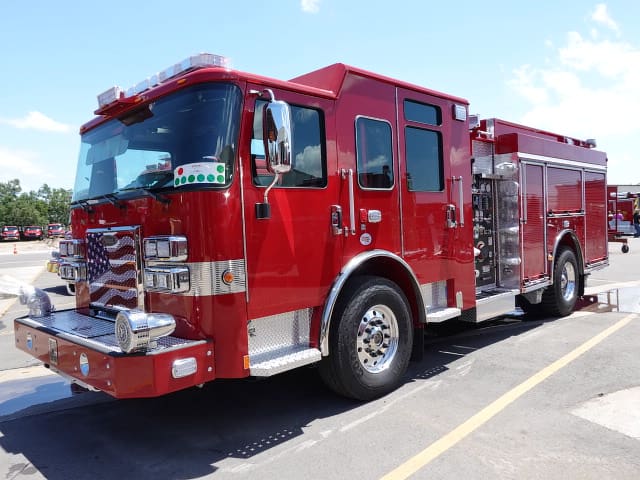

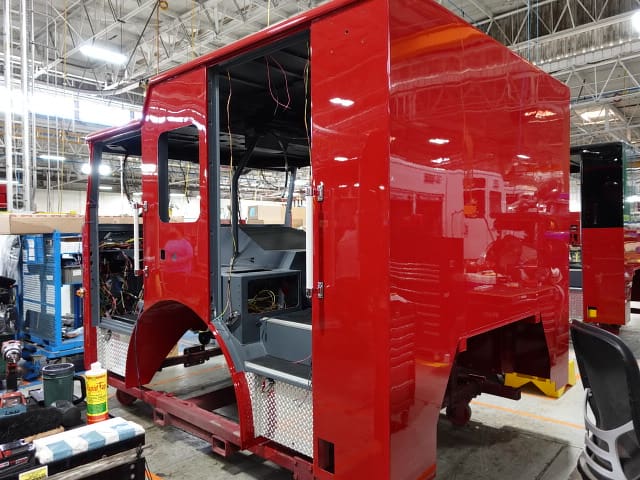

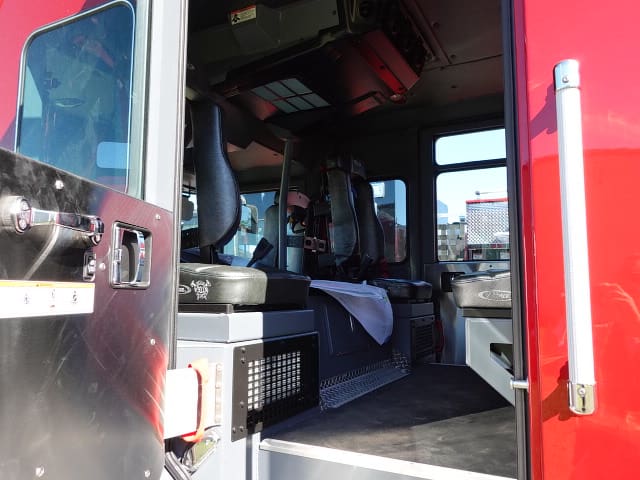

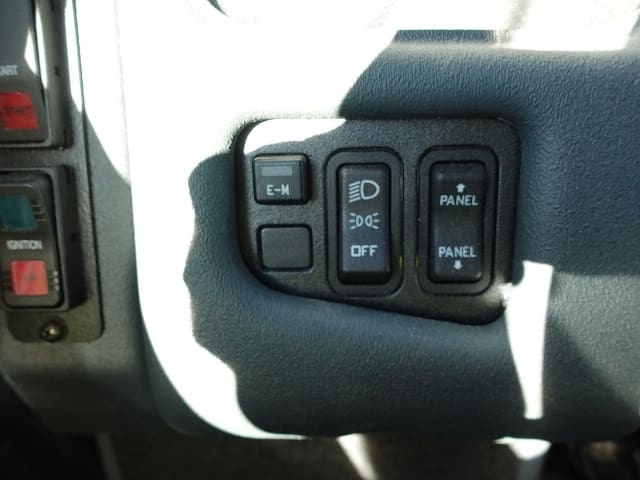

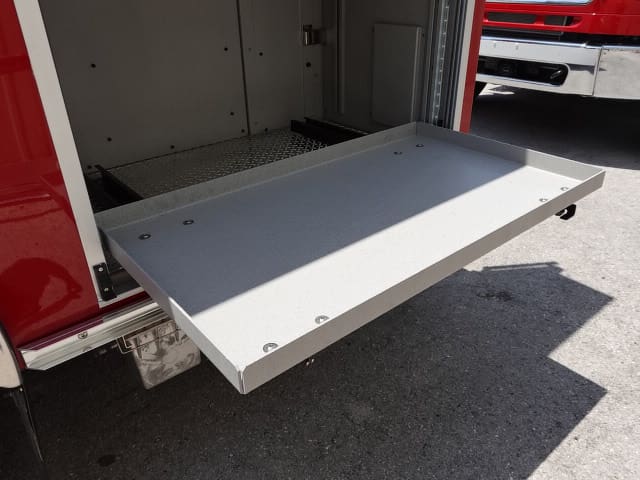

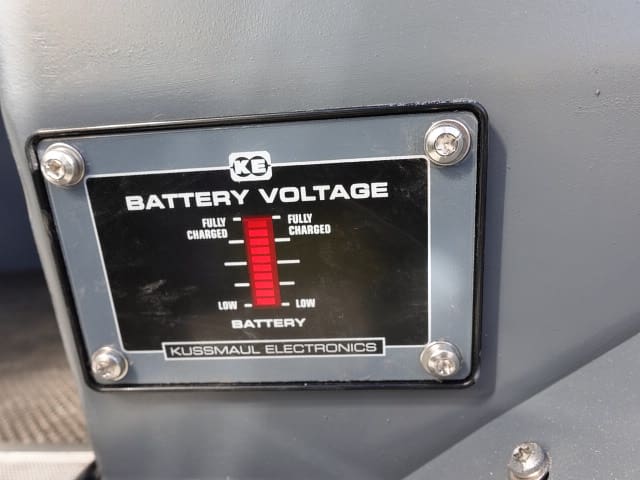

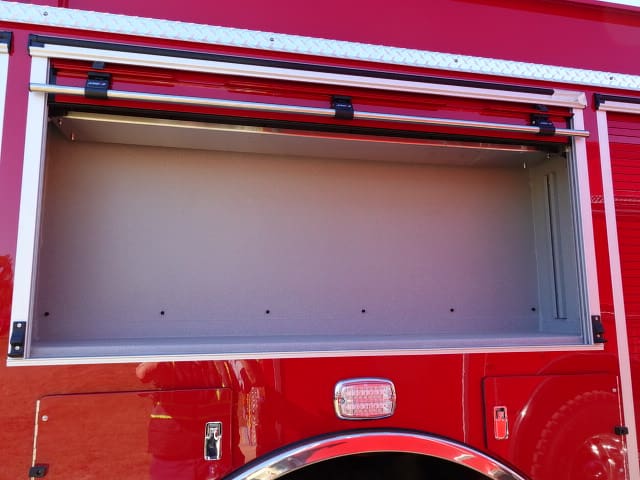

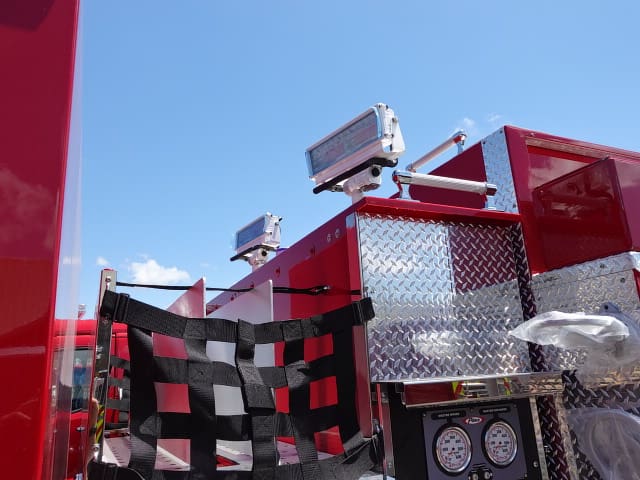

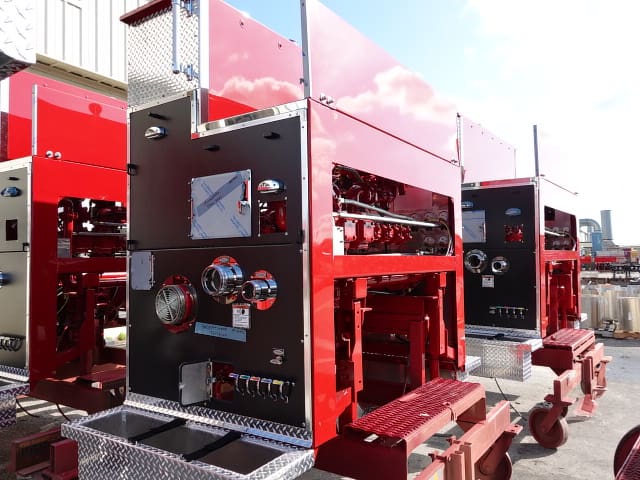

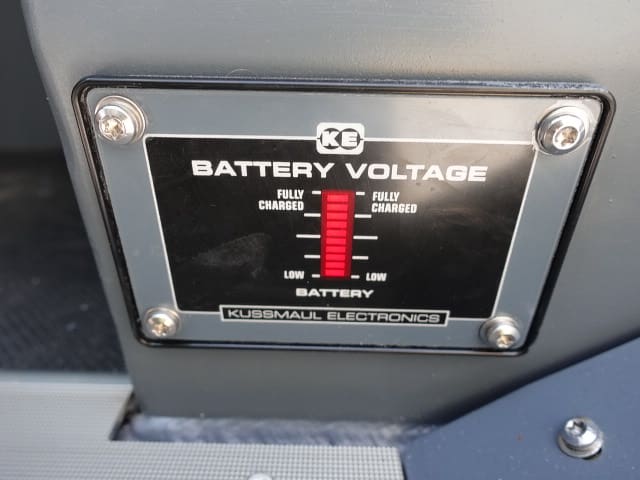

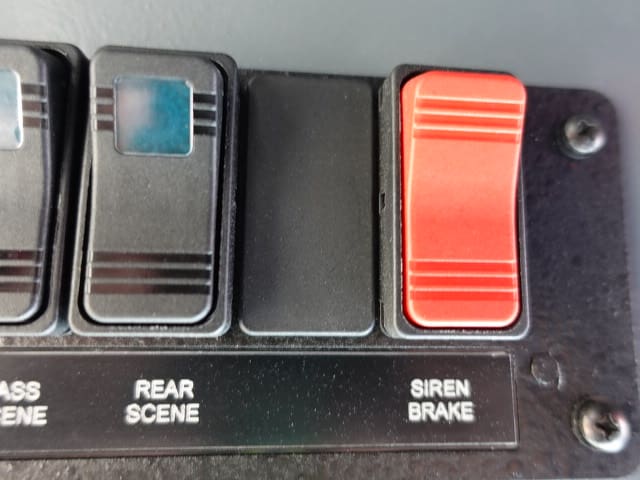

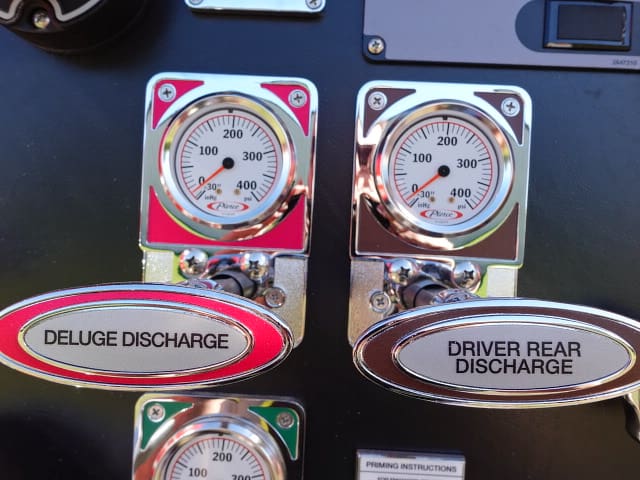

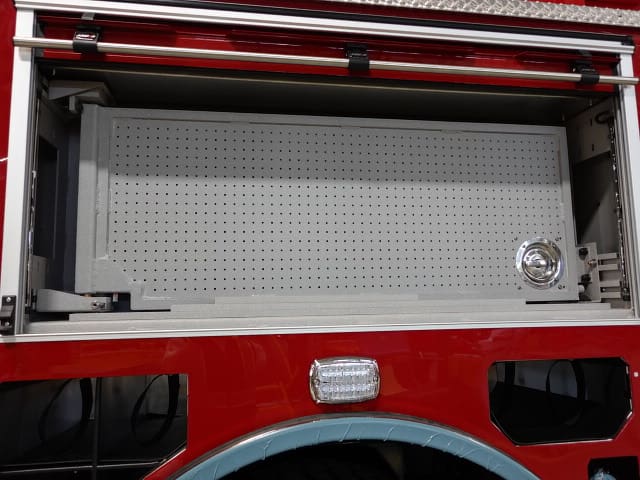

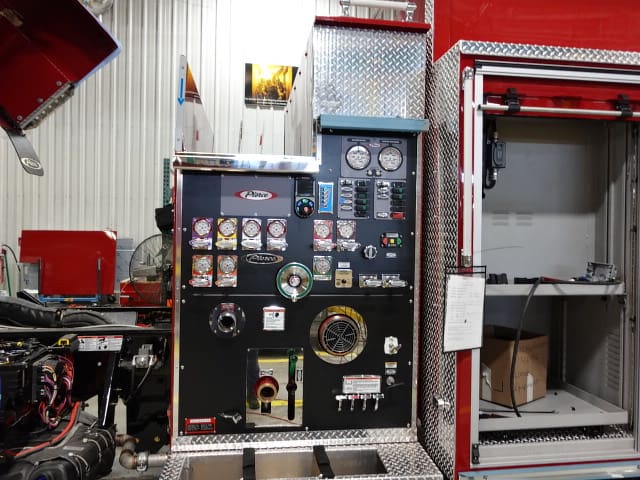

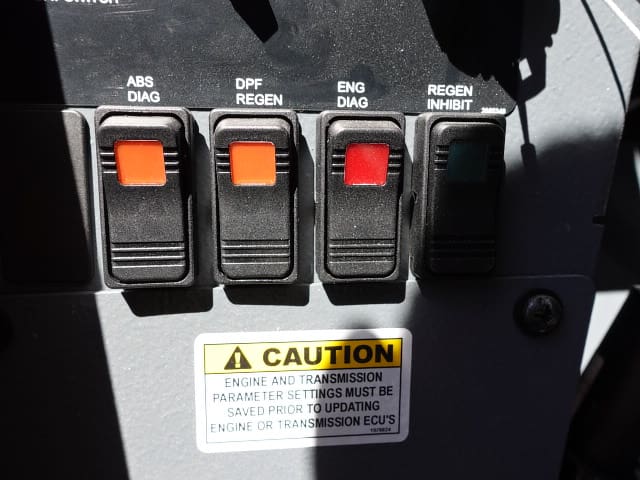

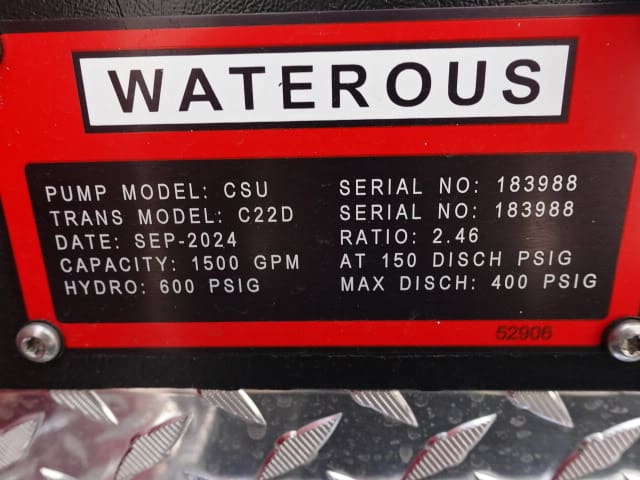

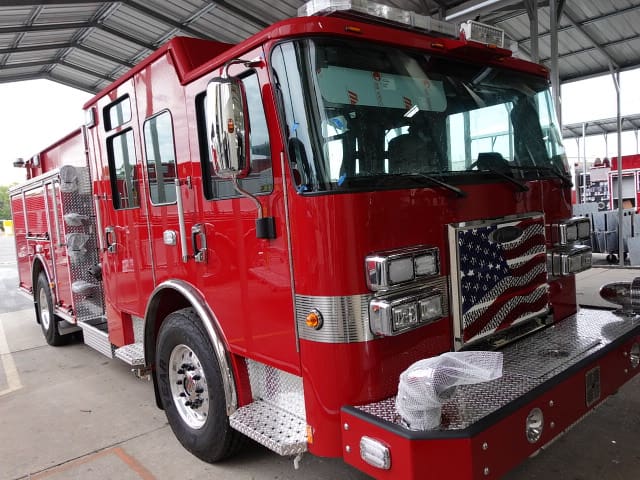

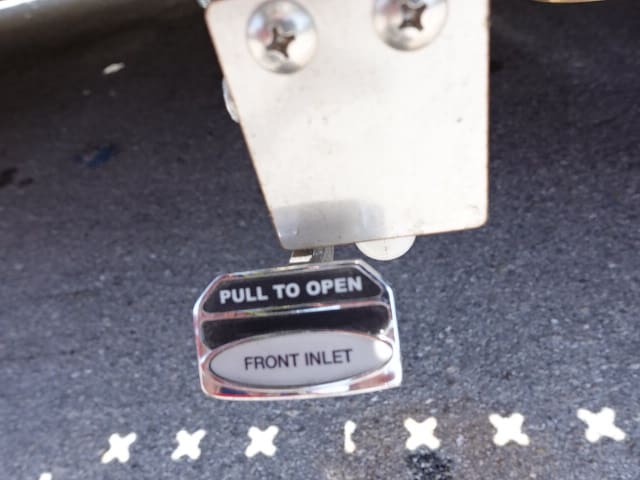

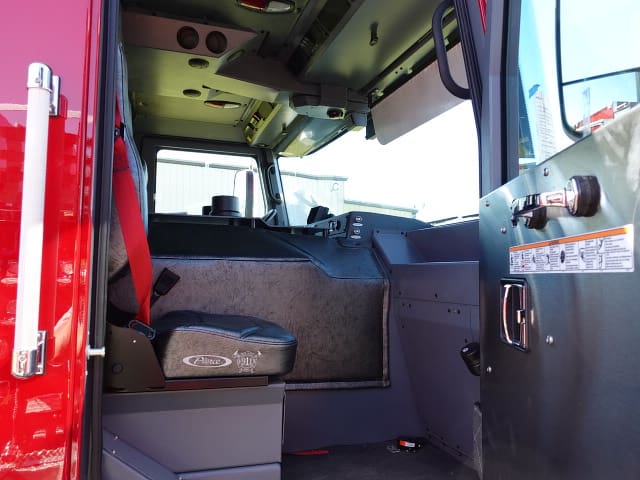

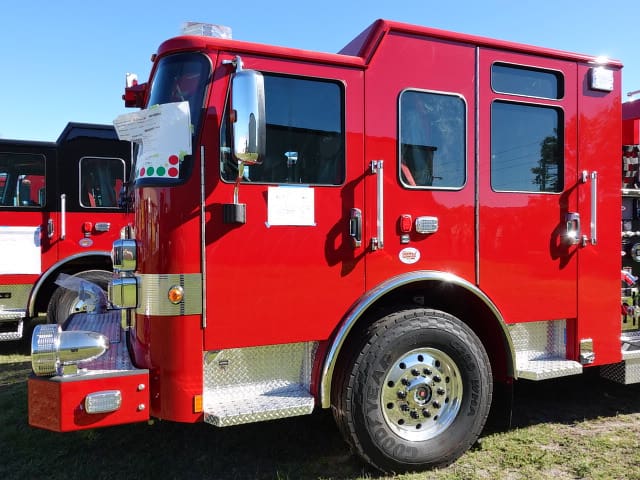

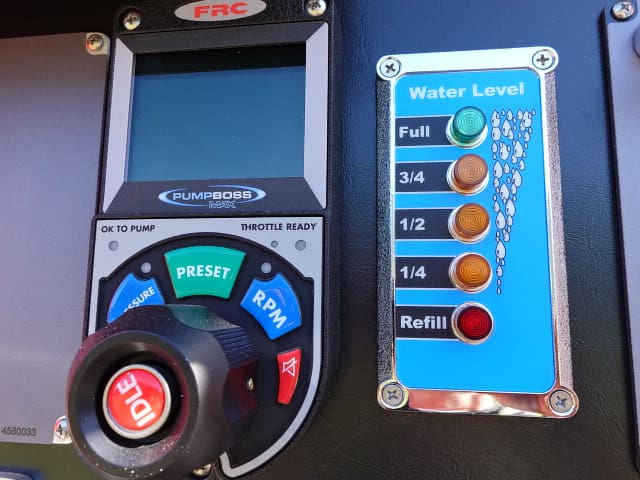

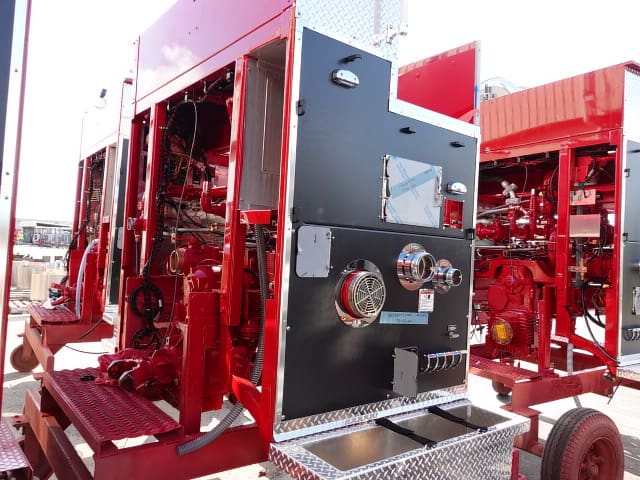

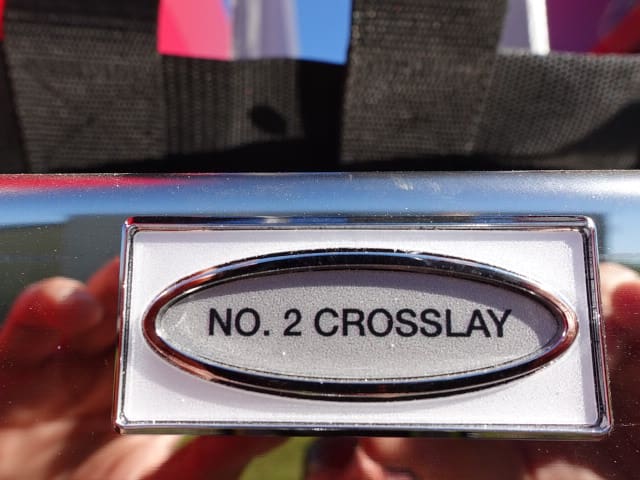

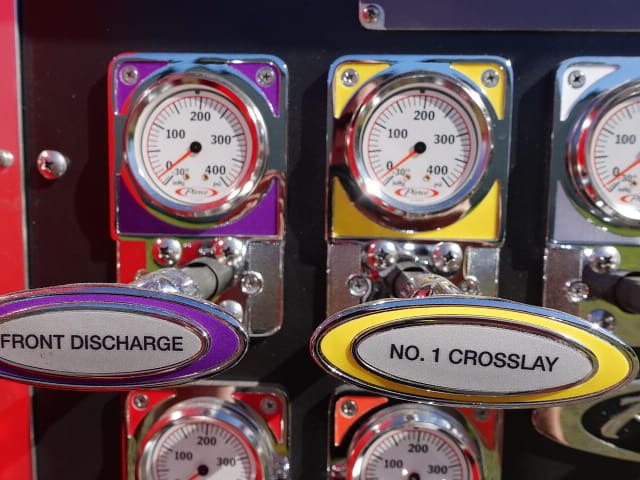

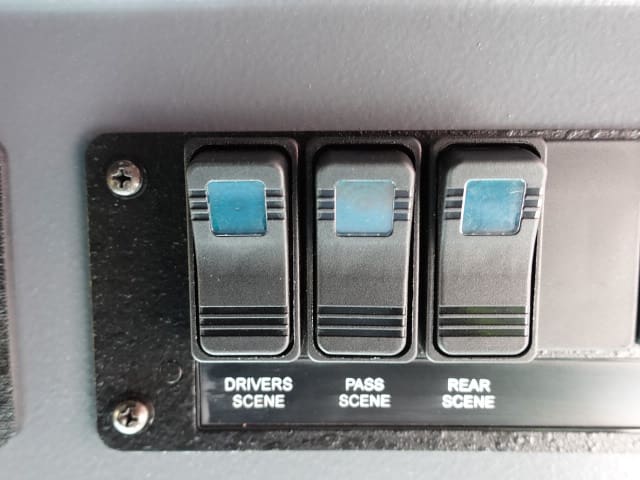

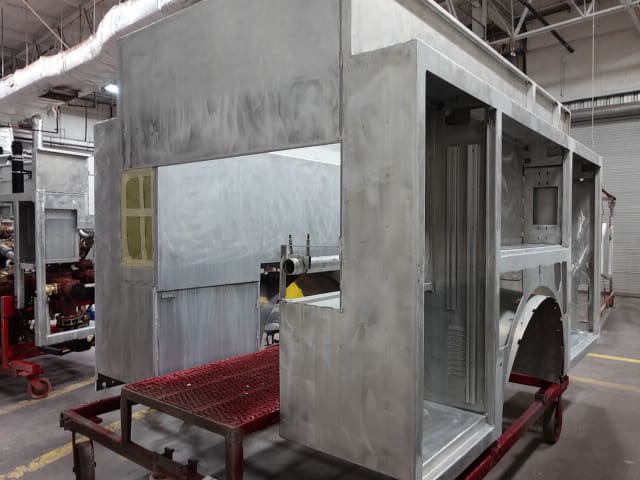

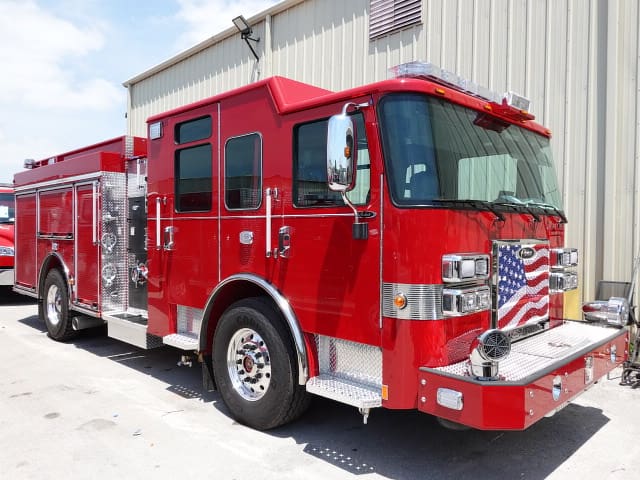

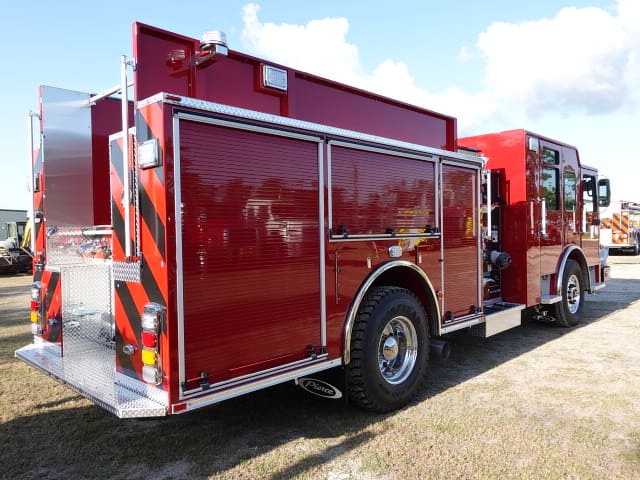

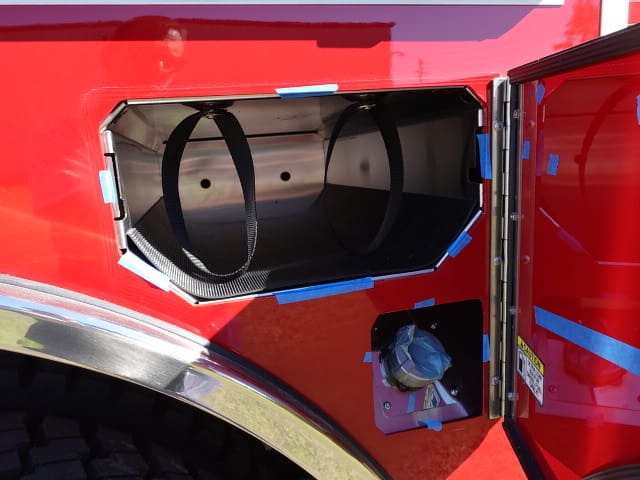

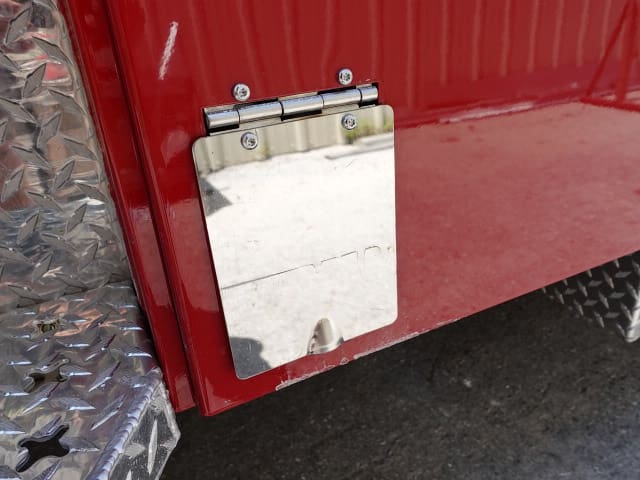

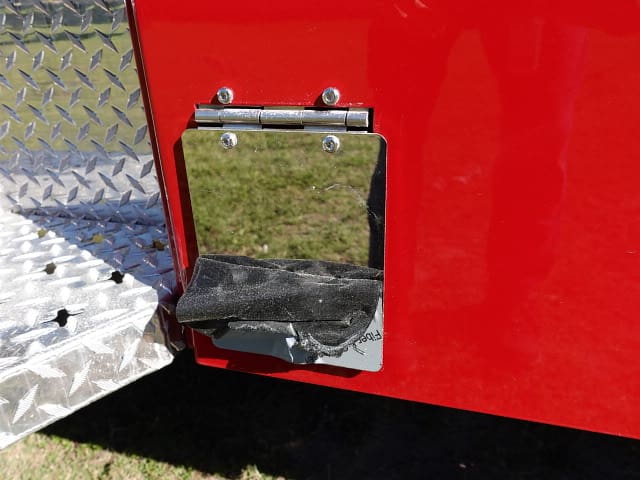

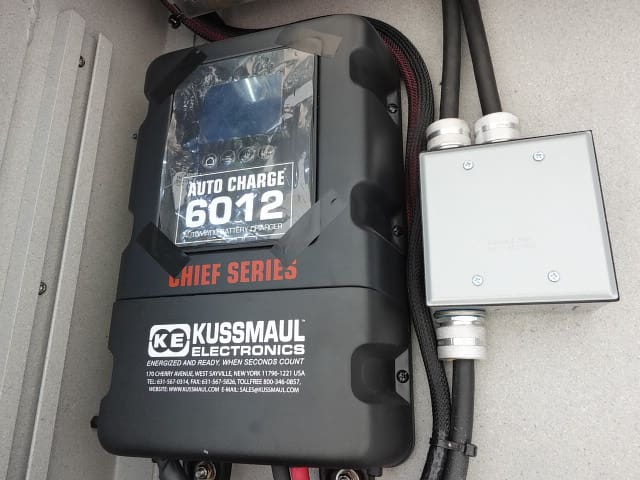

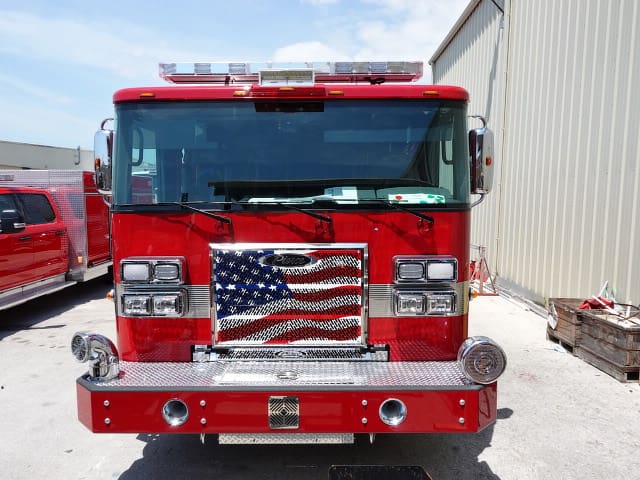

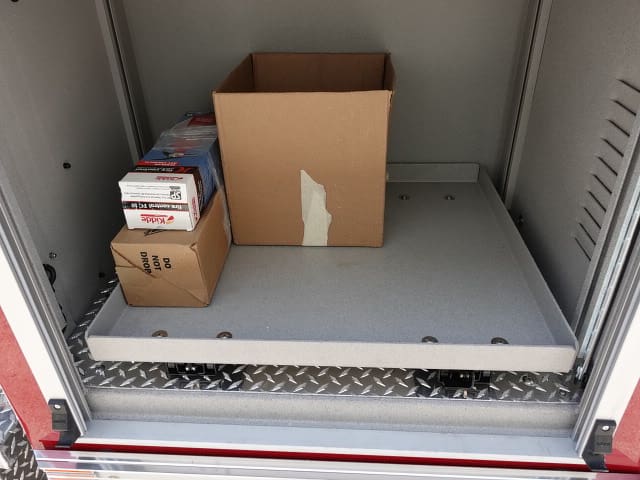

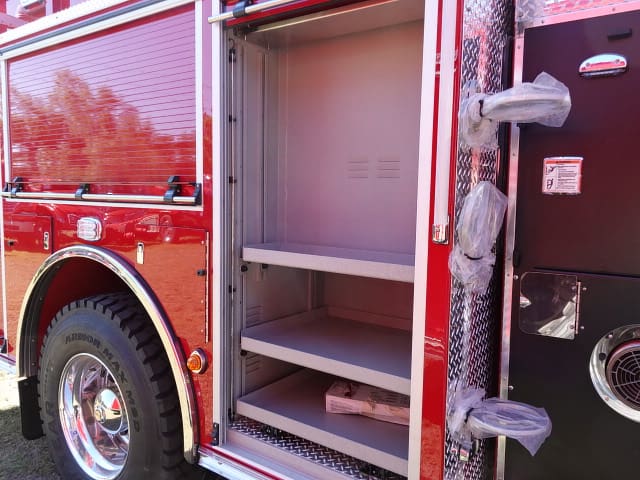

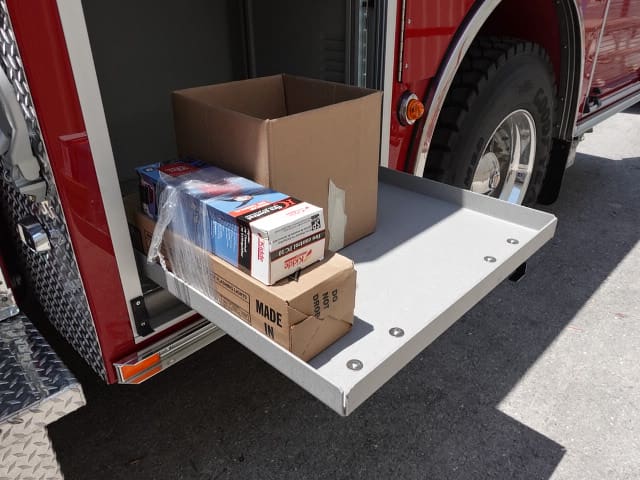

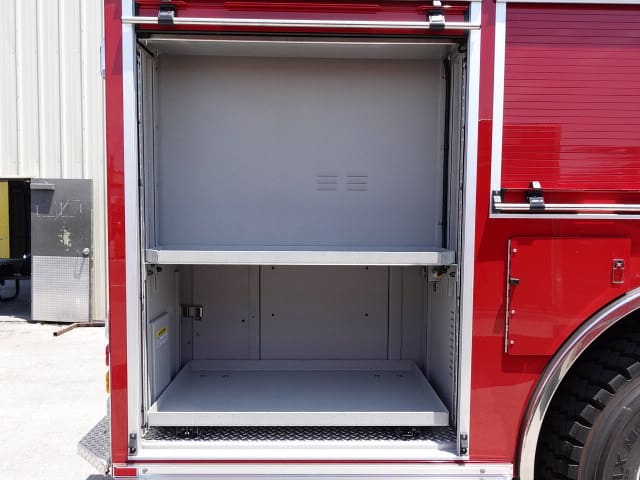

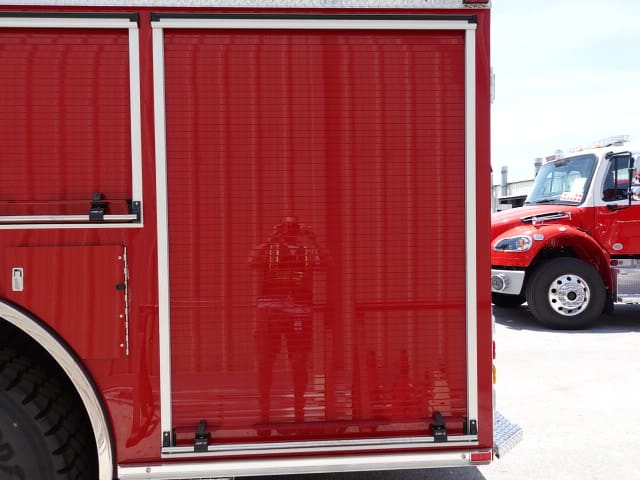

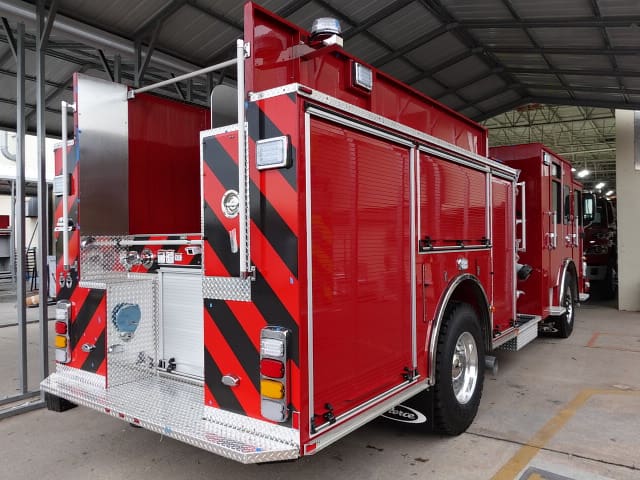

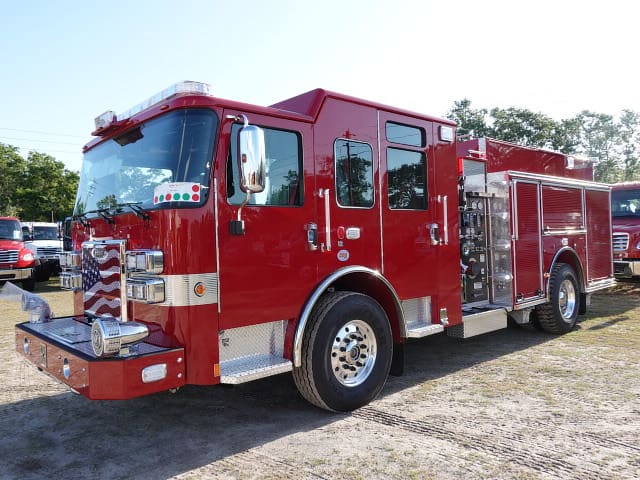

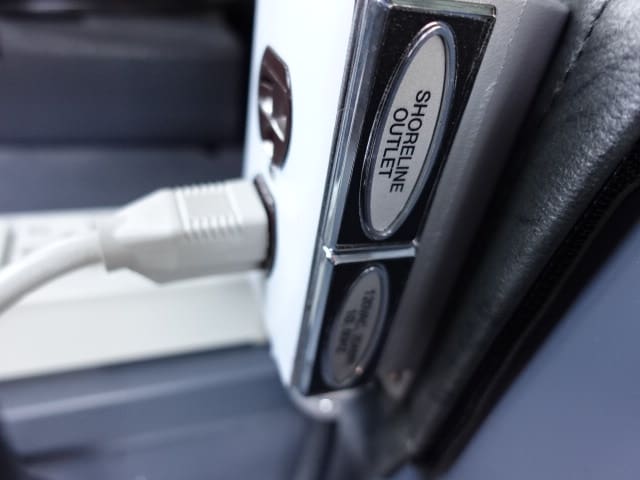

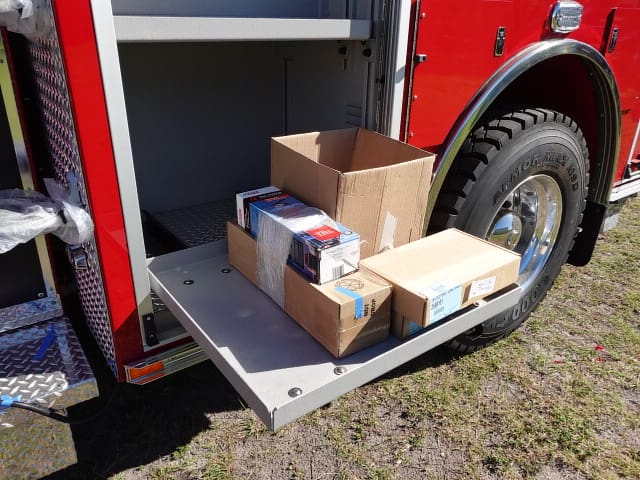

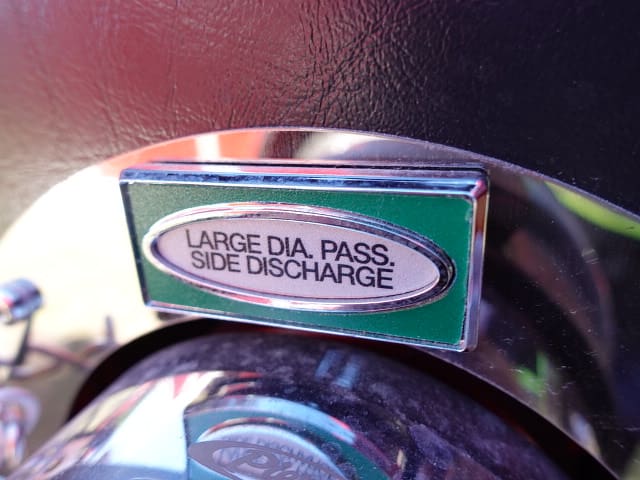

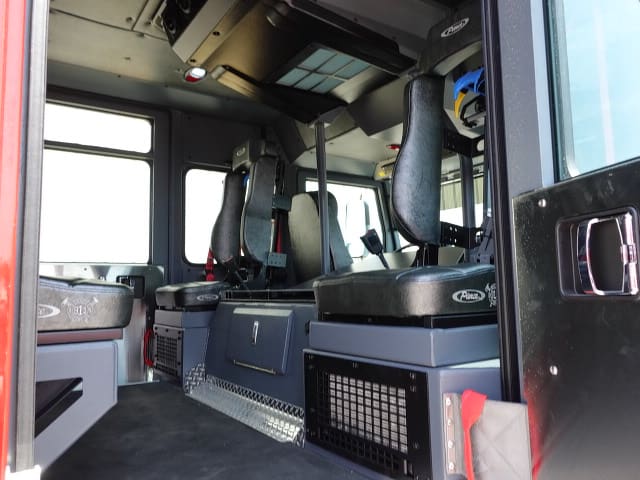

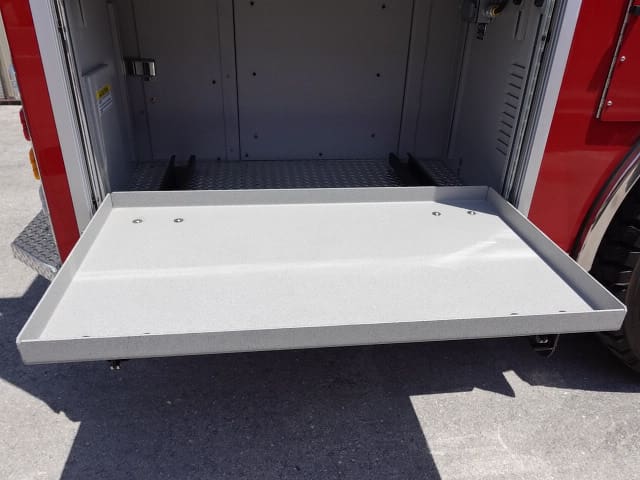

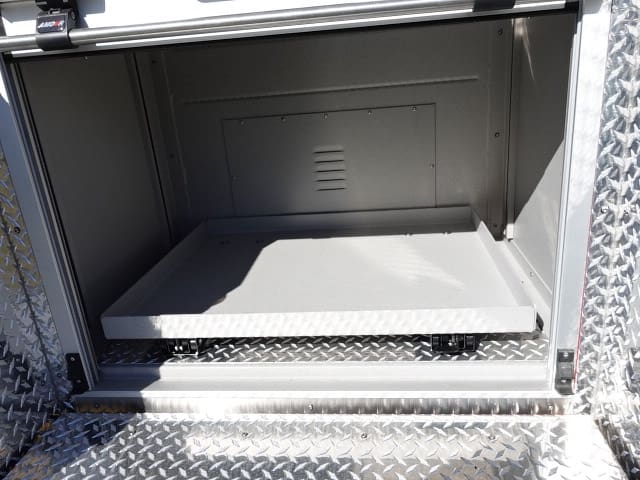

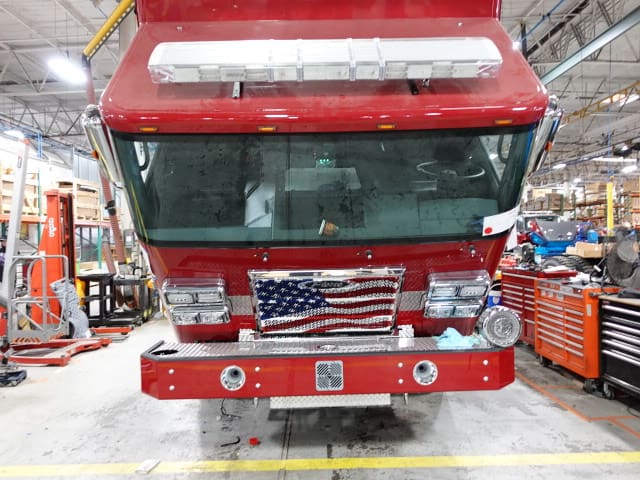

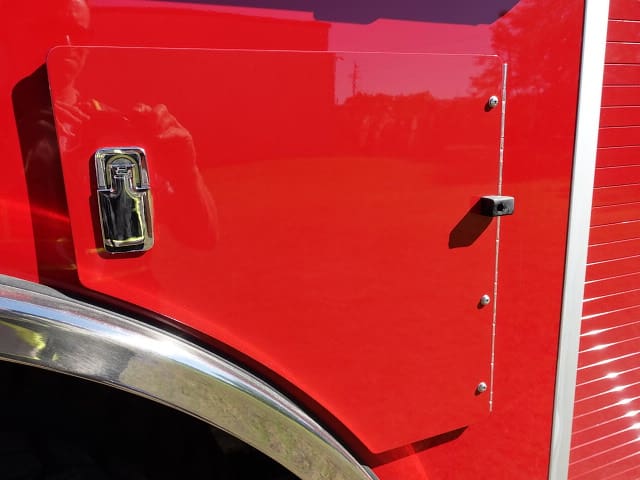

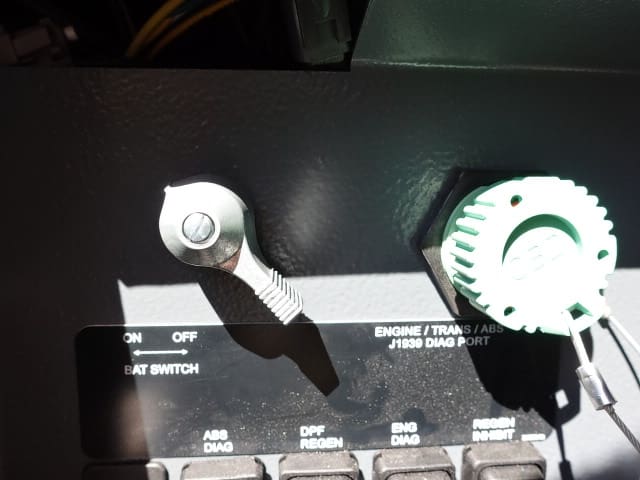

In this report, the apparatus was released to final product evaluation where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.

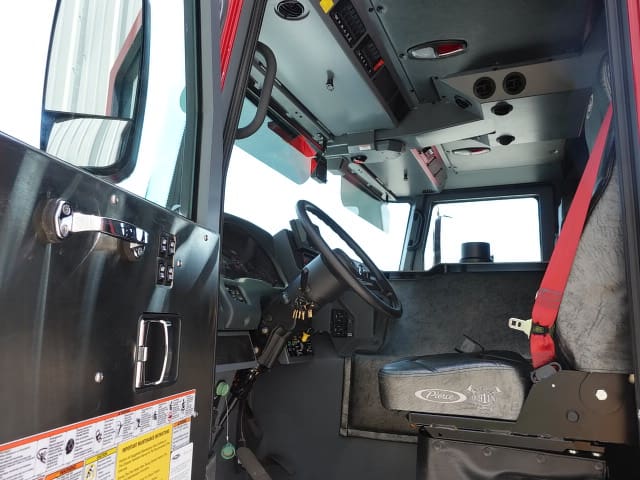

03-07-25

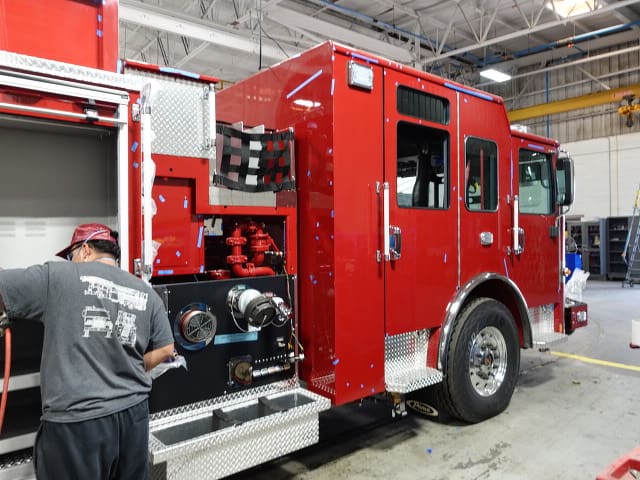

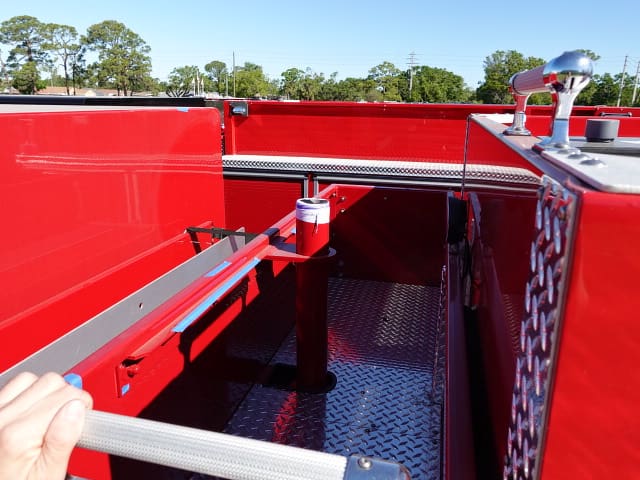

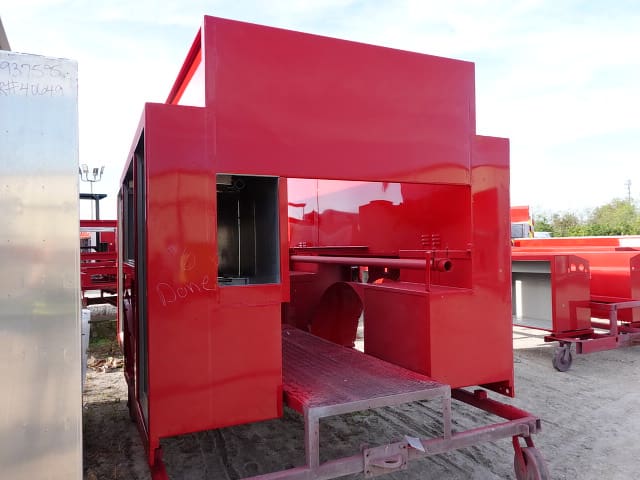

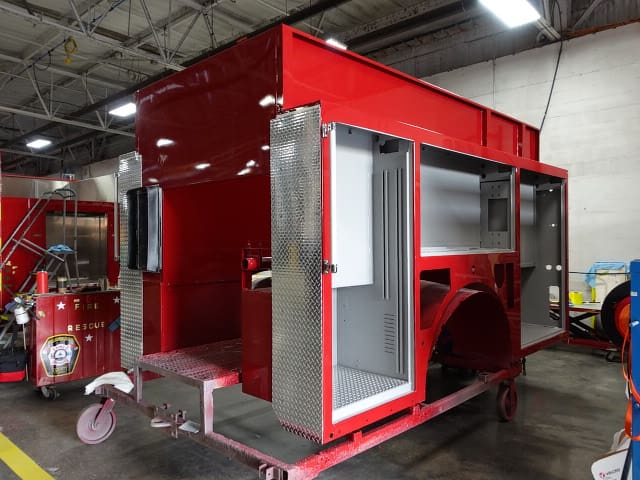

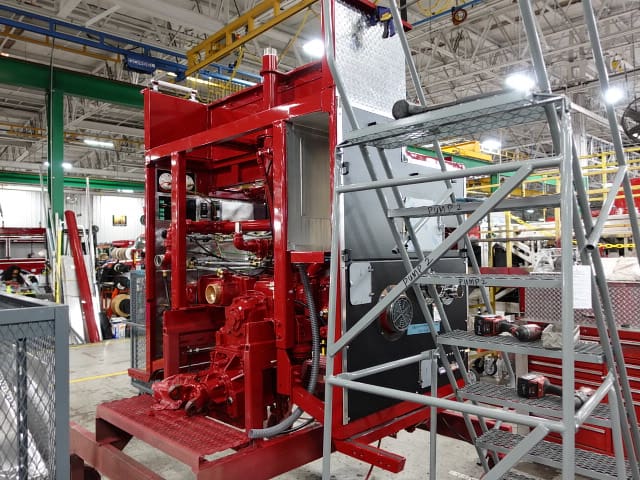

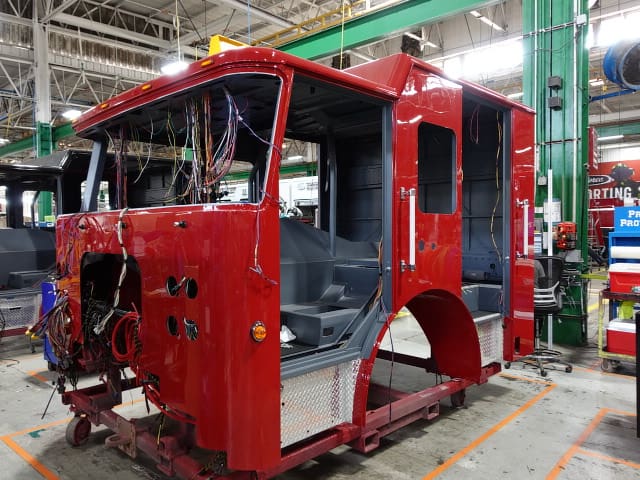

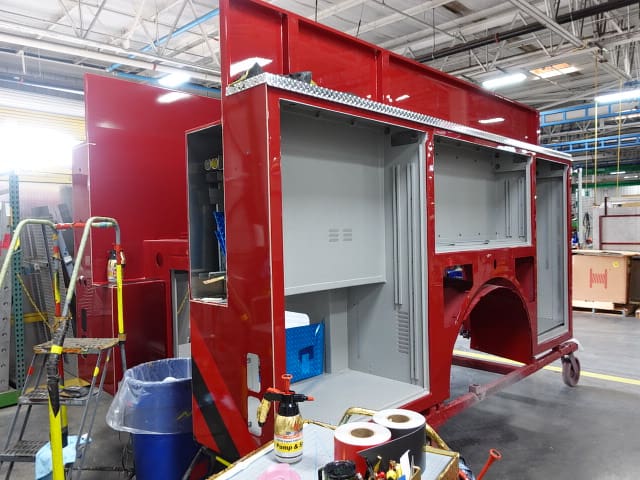

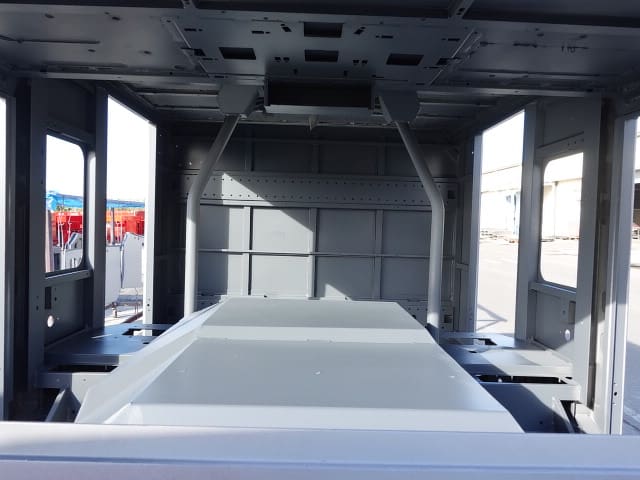

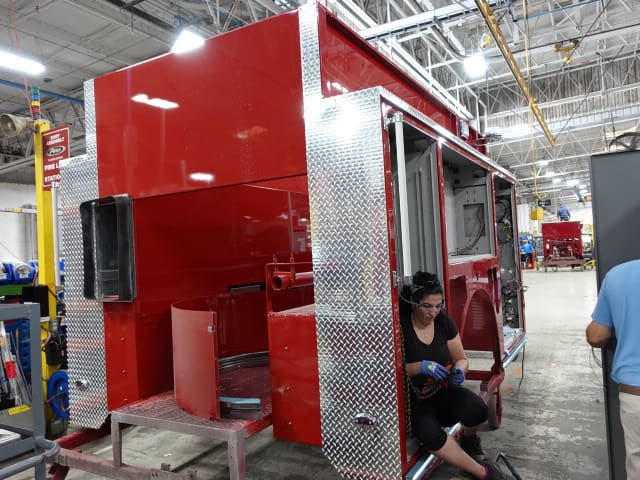

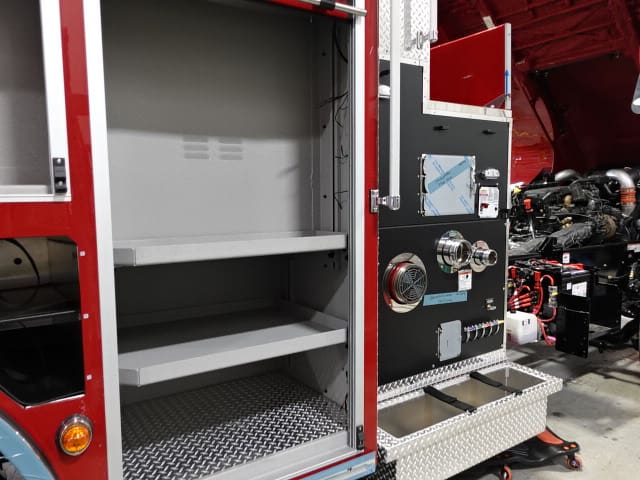

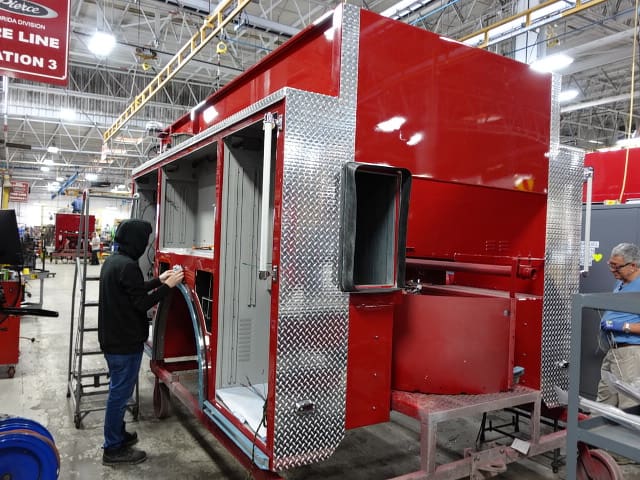

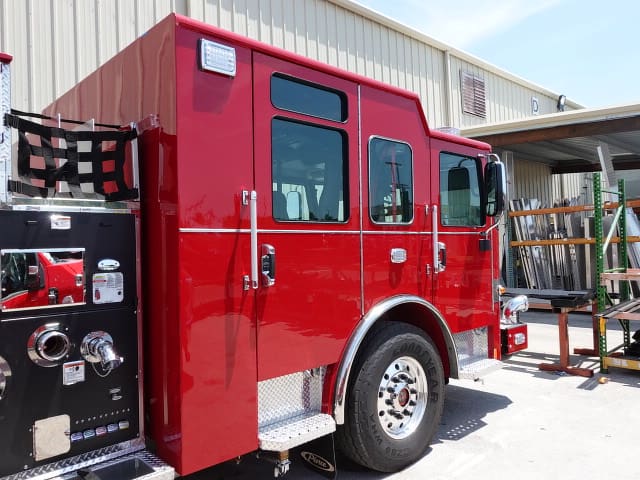

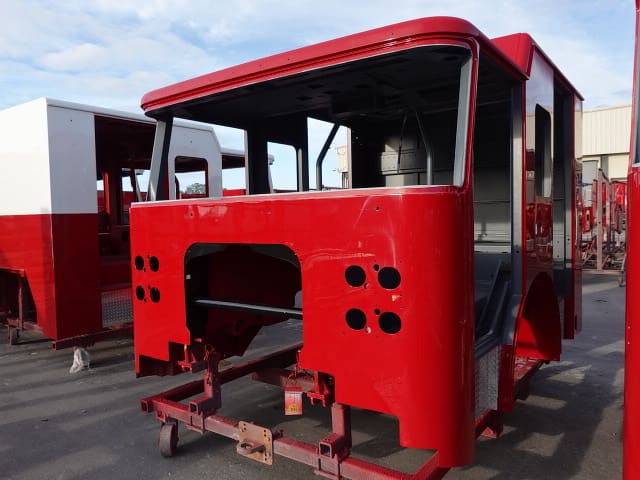

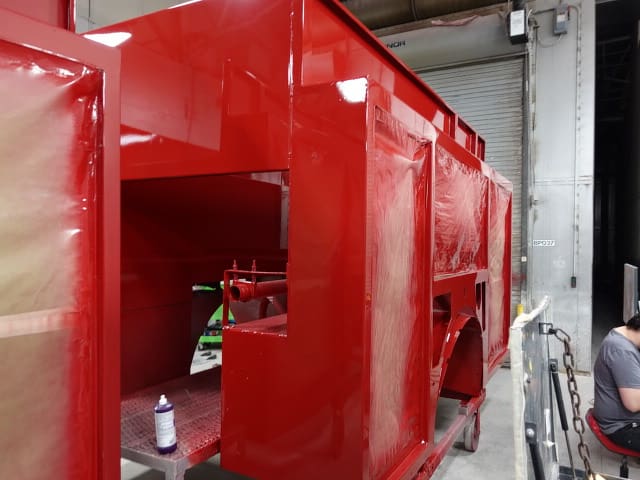

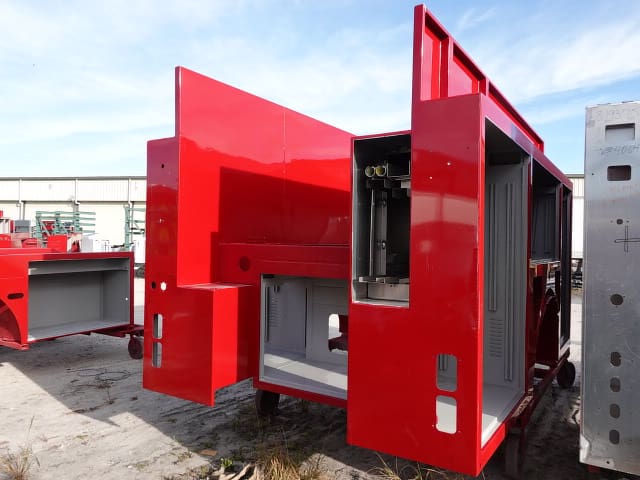

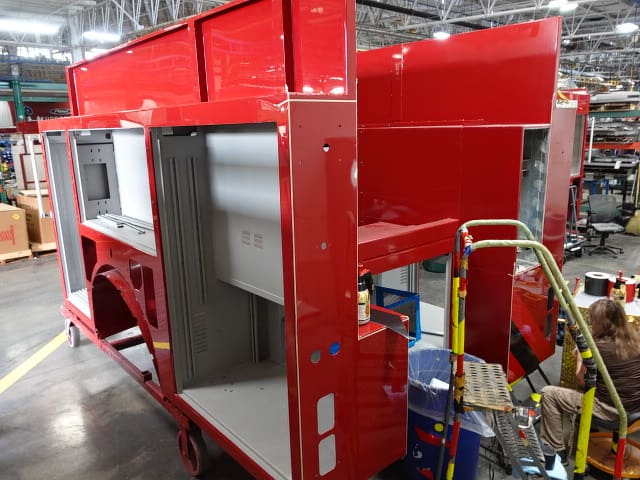

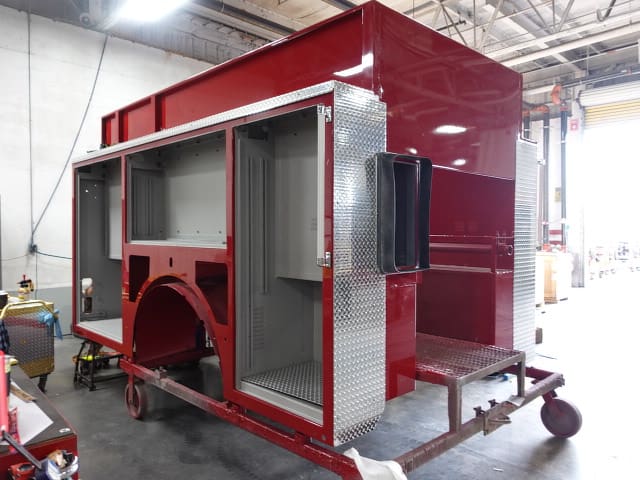

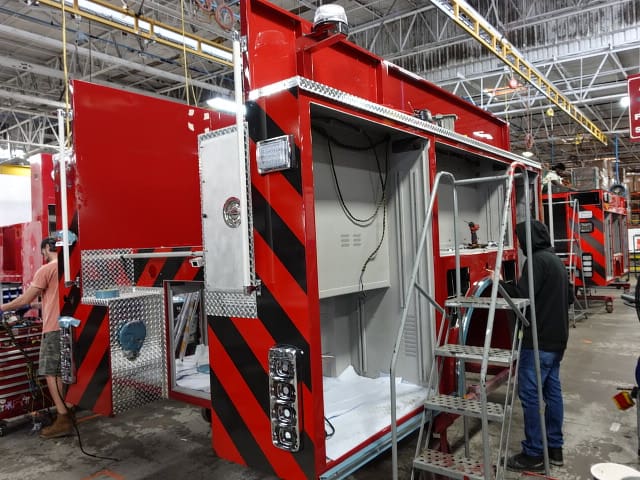

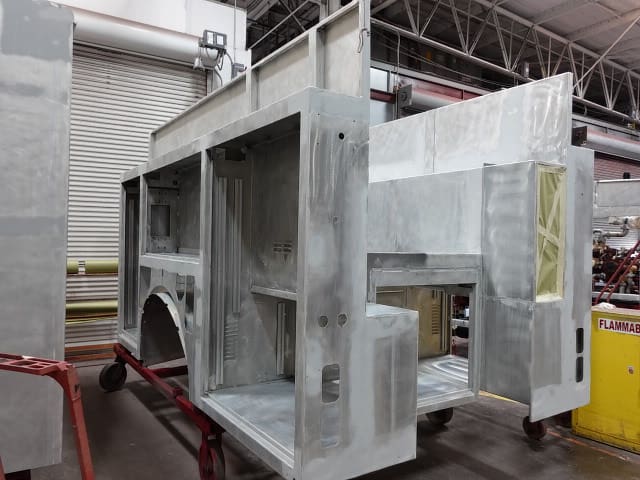

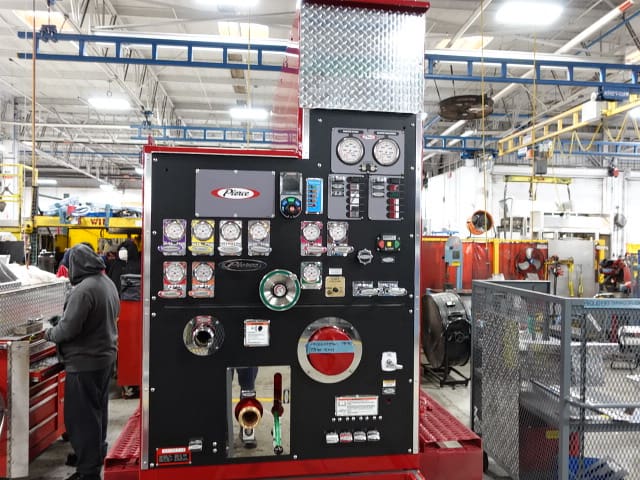

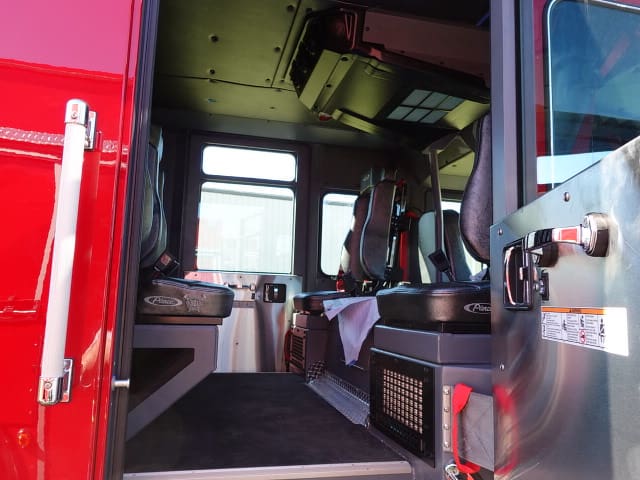

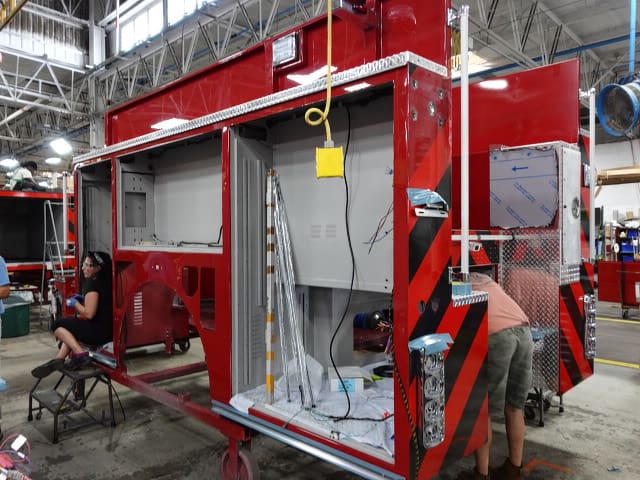

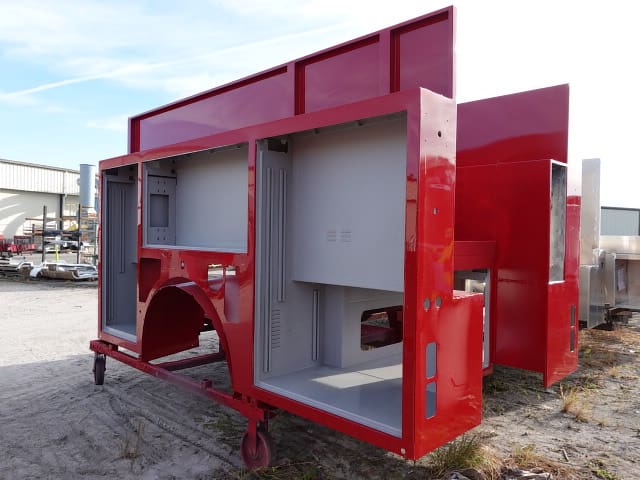

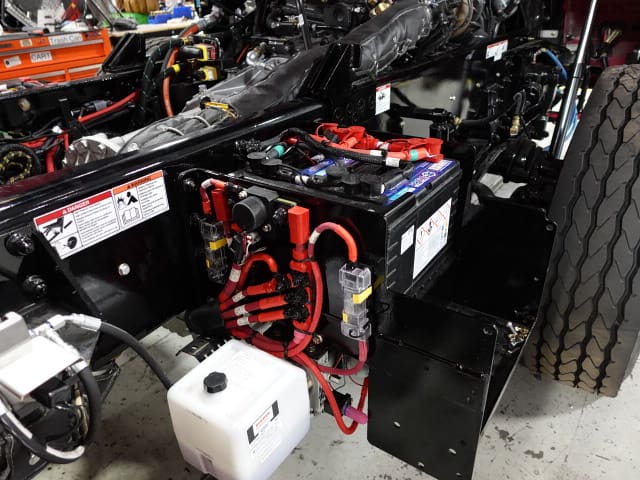

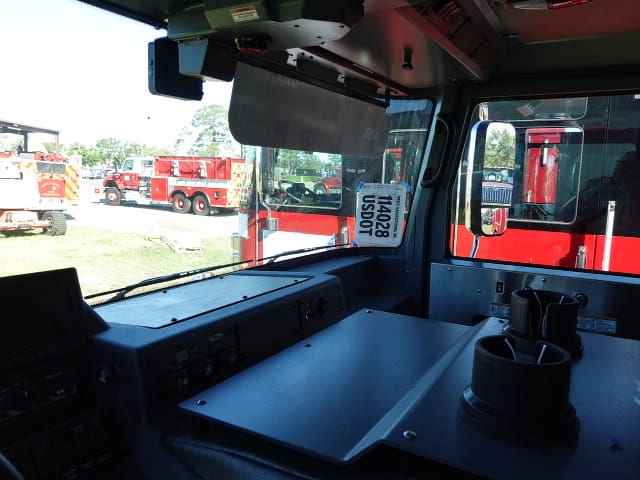

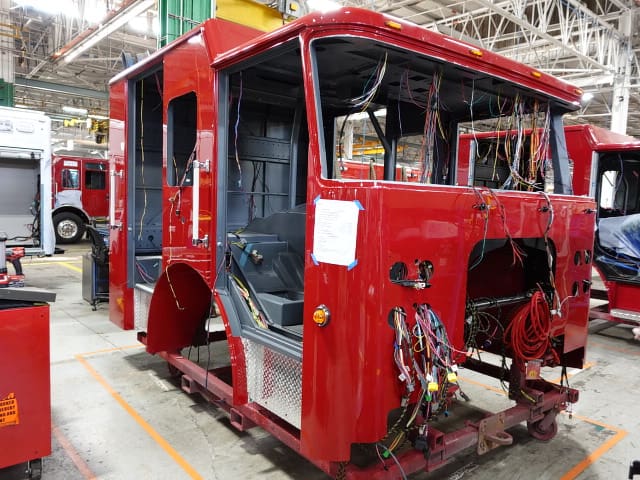

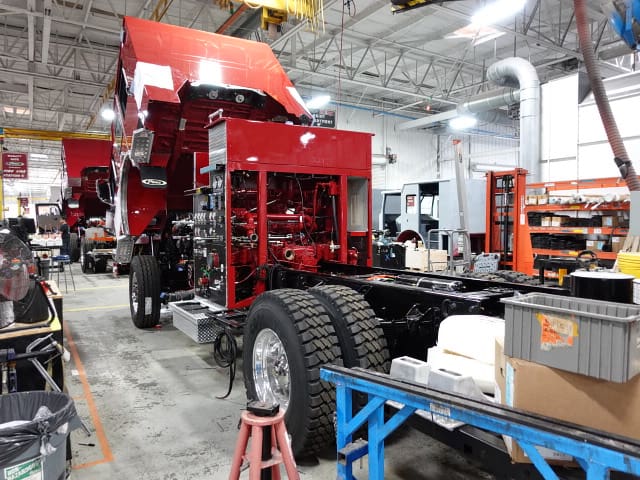

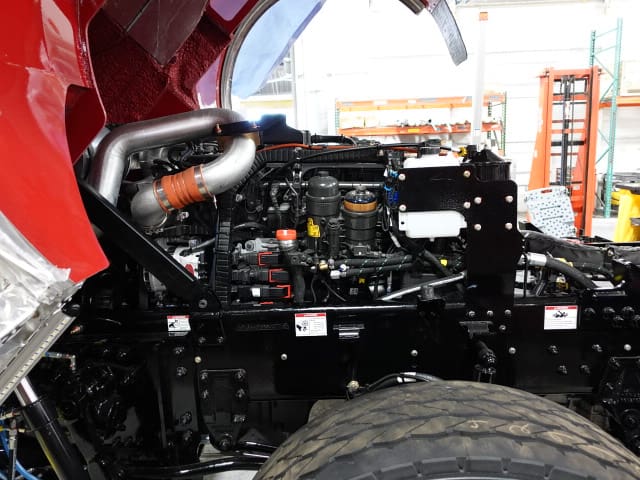

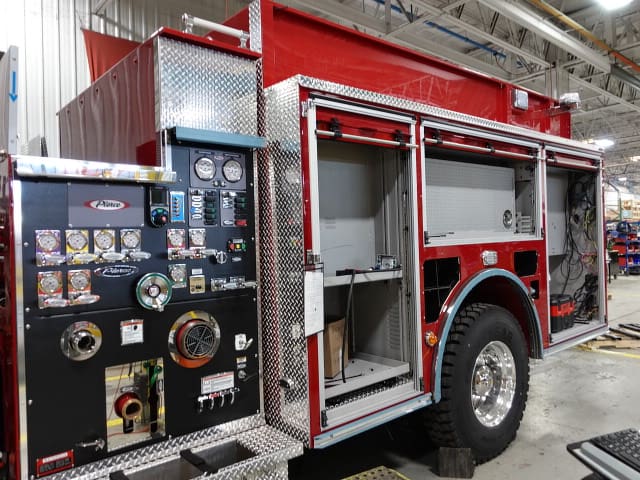

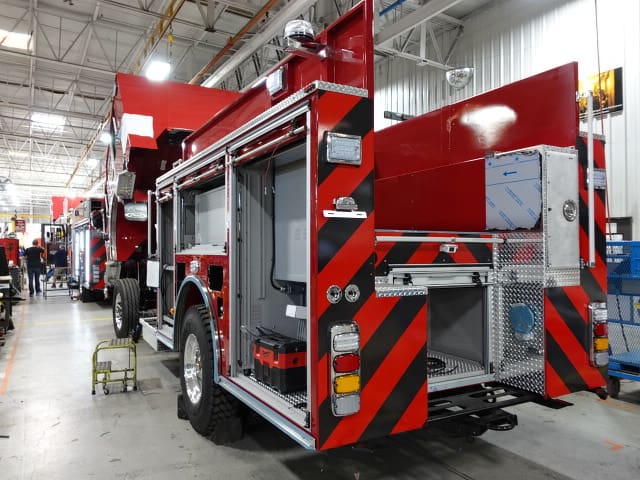

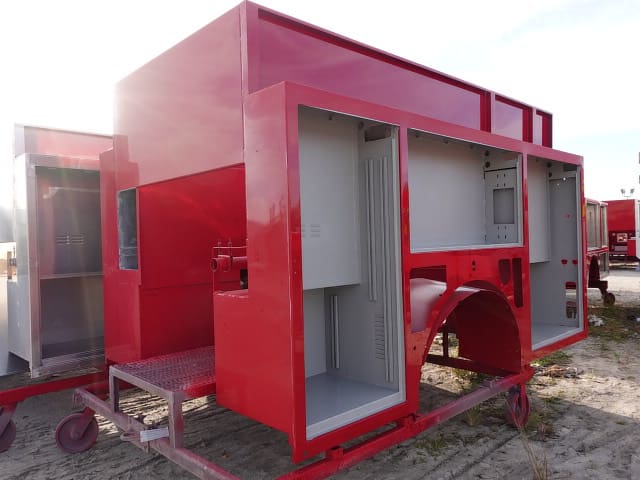

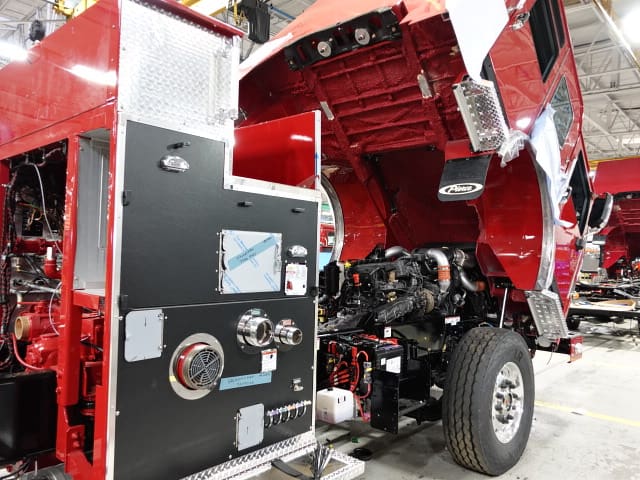

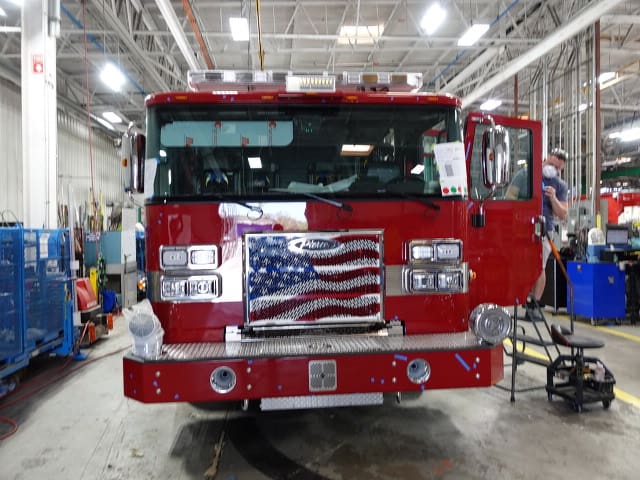

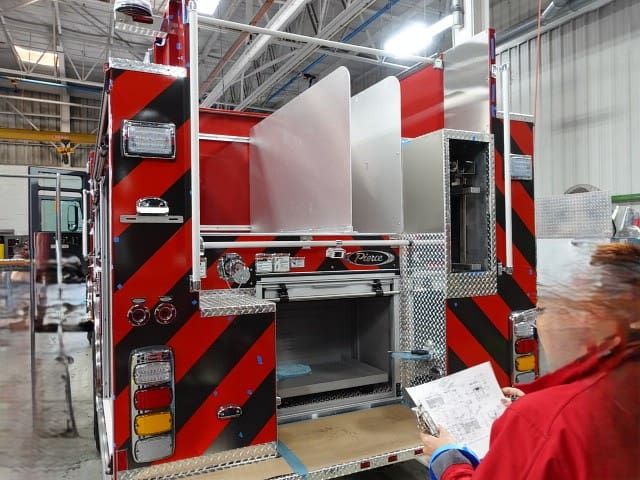

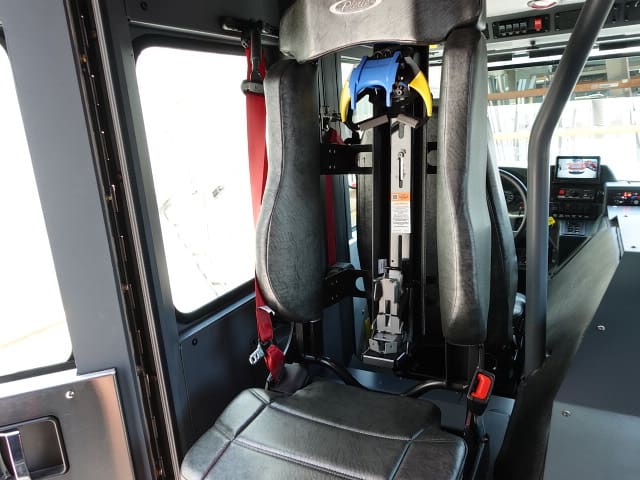

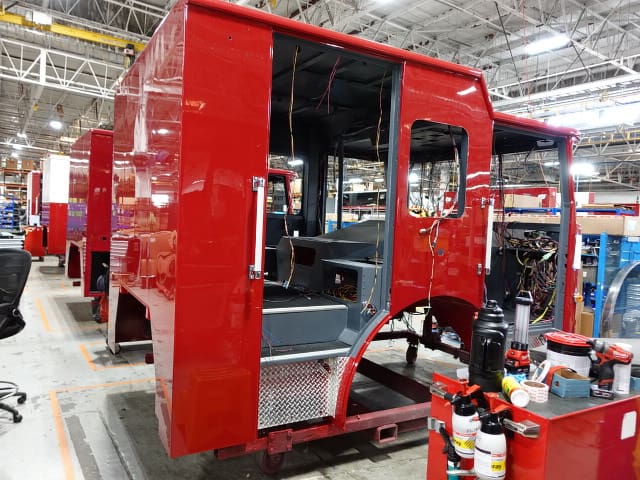

In this report, the body was merged with the chassis followed by the start of final assembly.

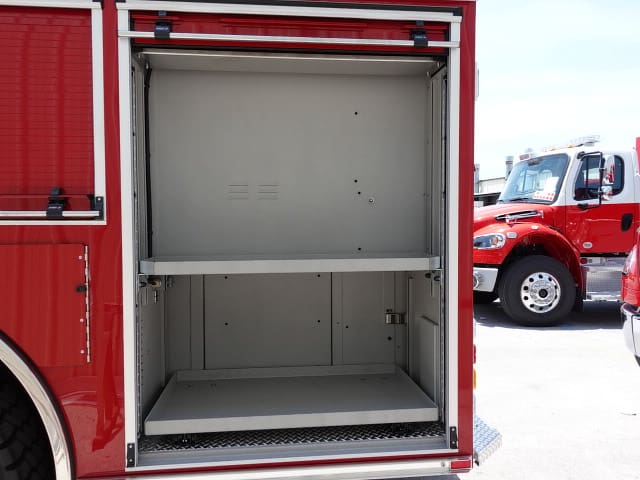

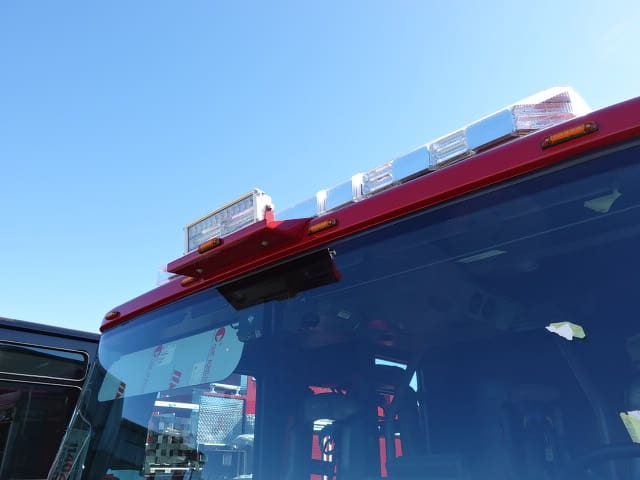

02-28-25

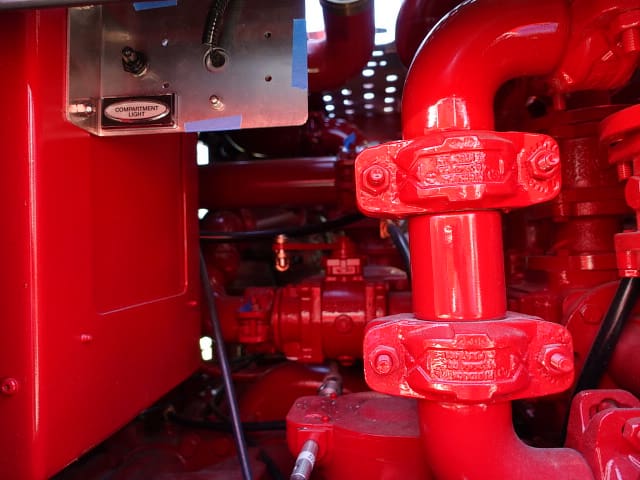

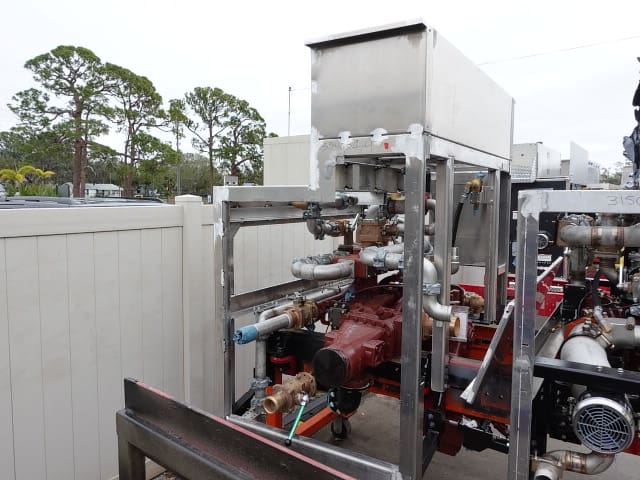

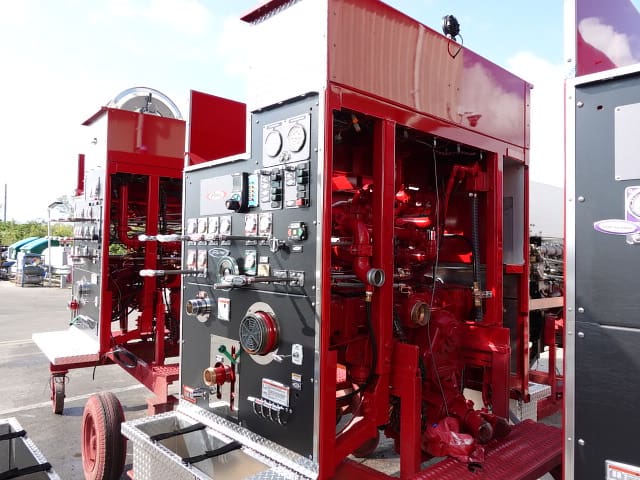

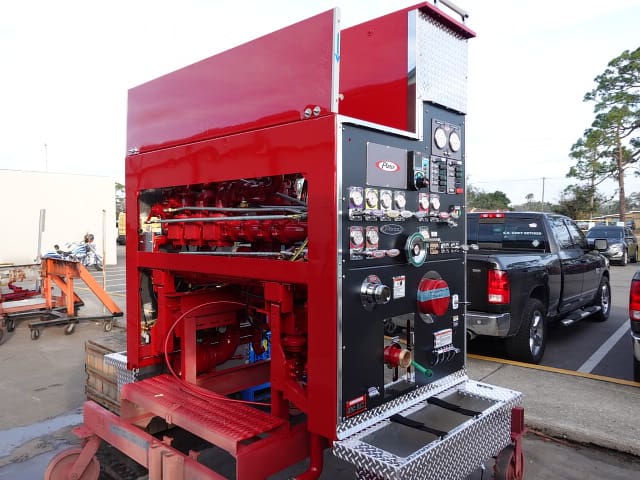

In this report, the cab and pump house were installed on the frame while the body remained staged (no photos).
02-14-25

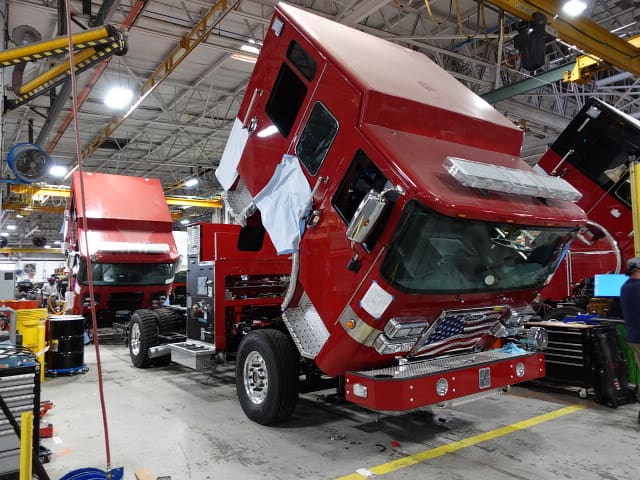

In this report, the cab began initial assembly, the frame build continued, the pump house was staged, and the body continued initial assembly.
02-07-25
In this report, the cab, frame, and pump house all remained staged (no photos) while the body began initial assembly.

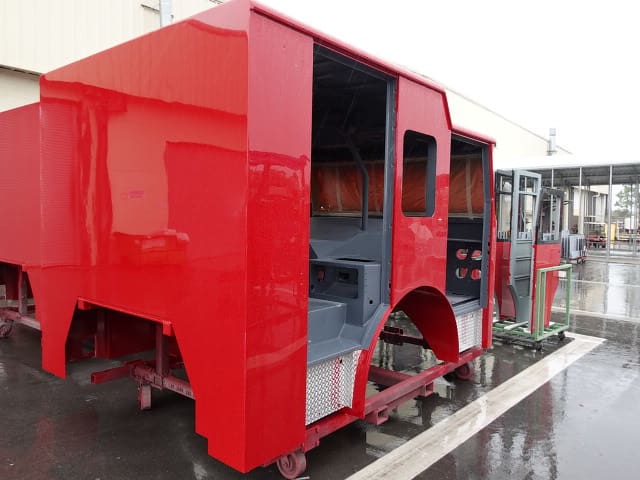

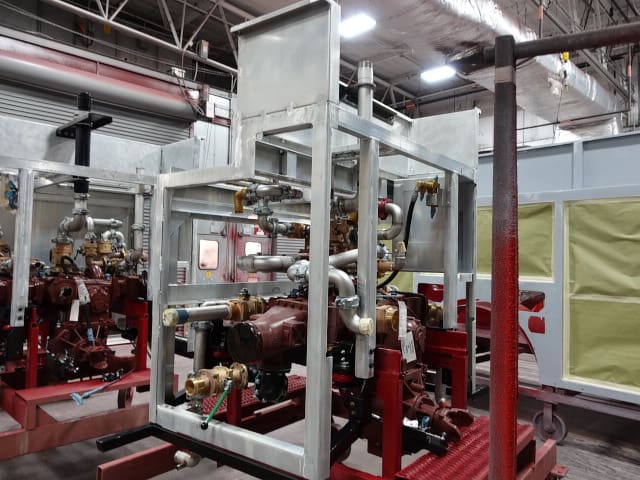

01-31-25

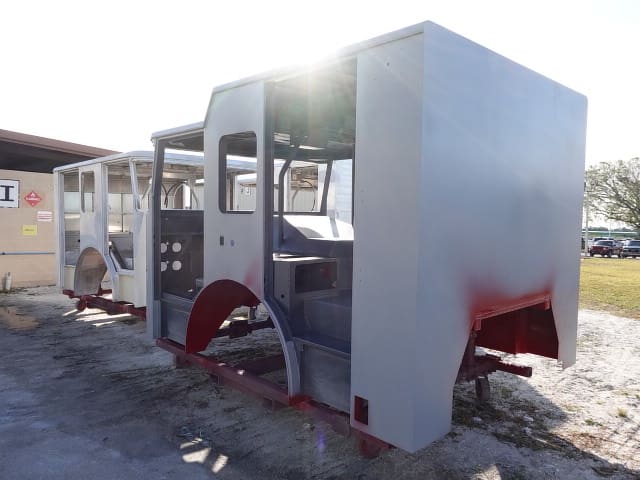

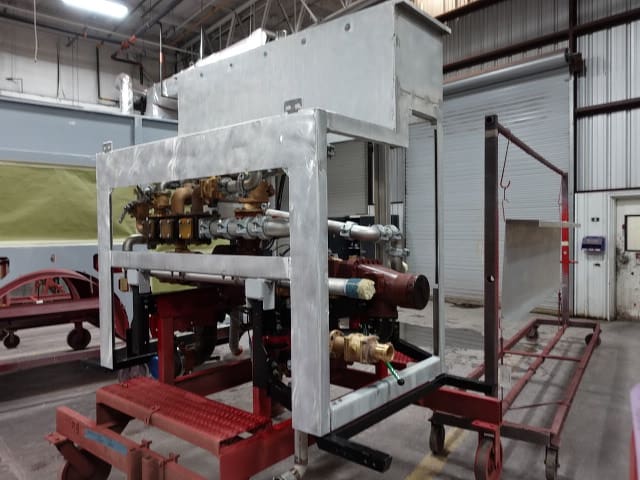

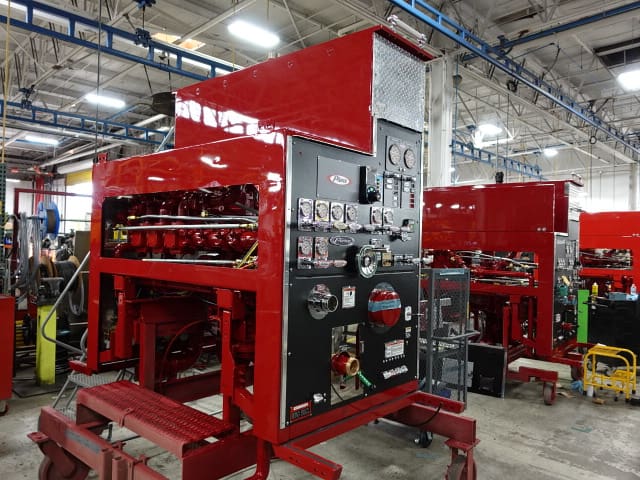

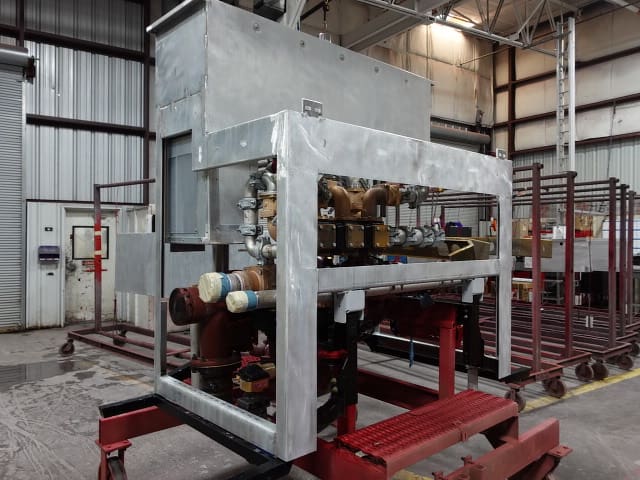

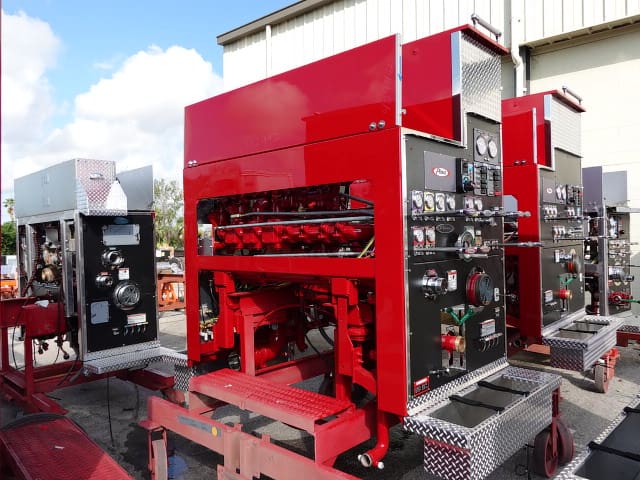

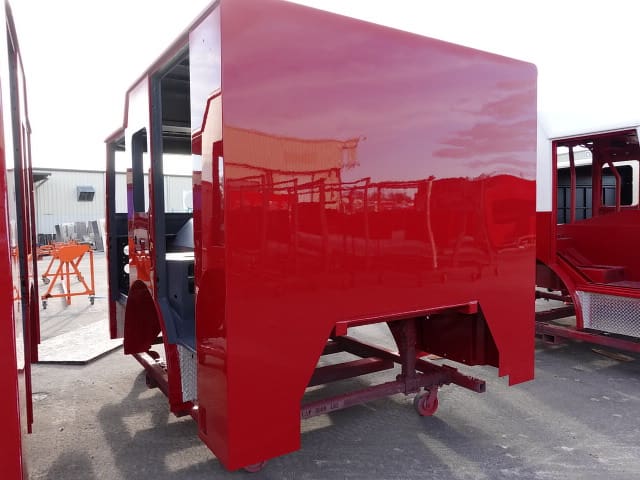

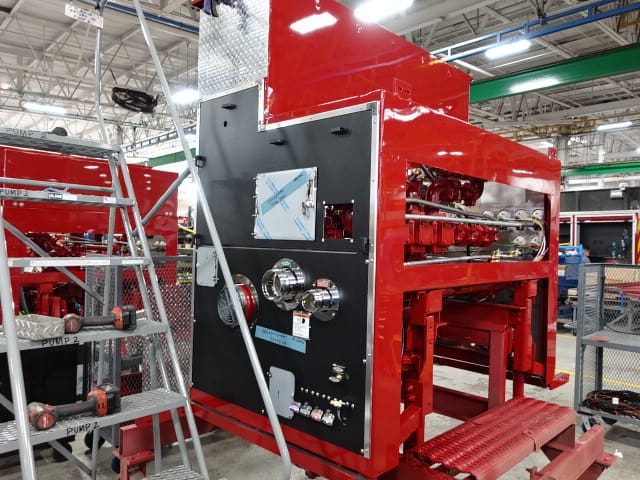

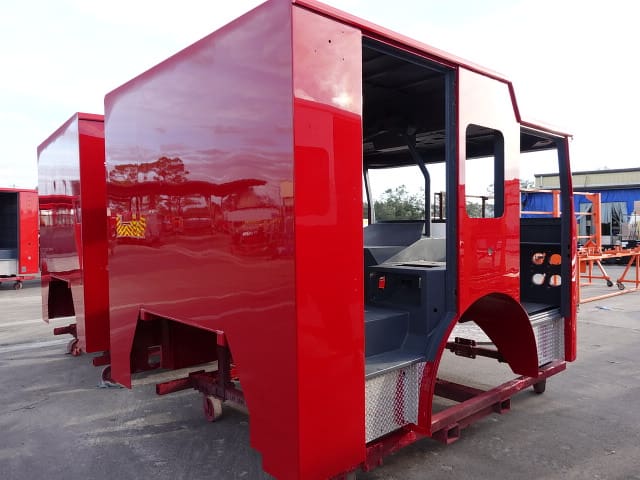

In this report, the cab completed paint, the frame build continued (no photos), the pump house completed initial assembly, and the body completed paint and was staged.
01-17-25

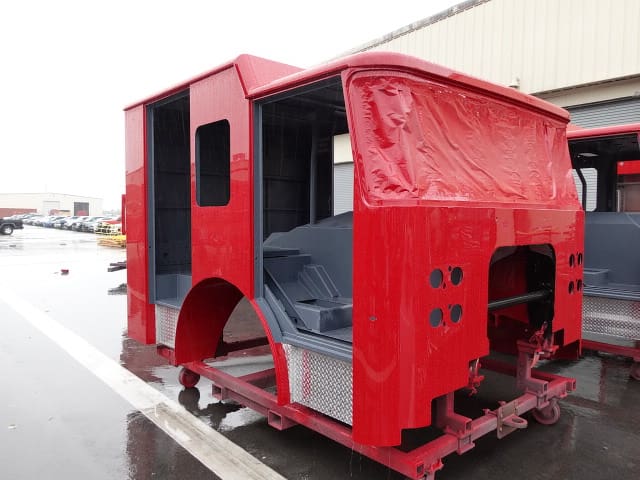

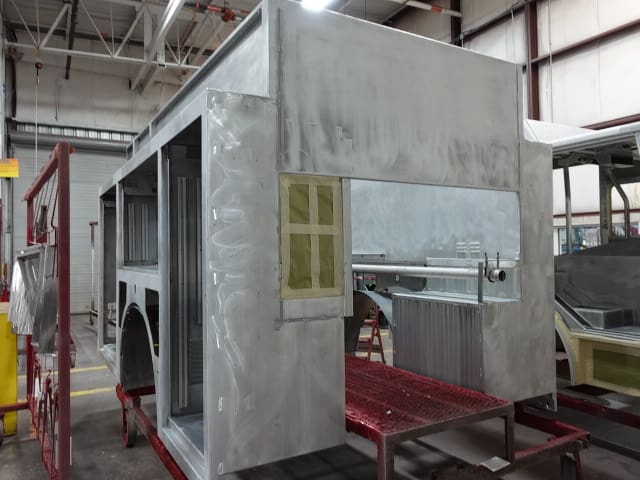

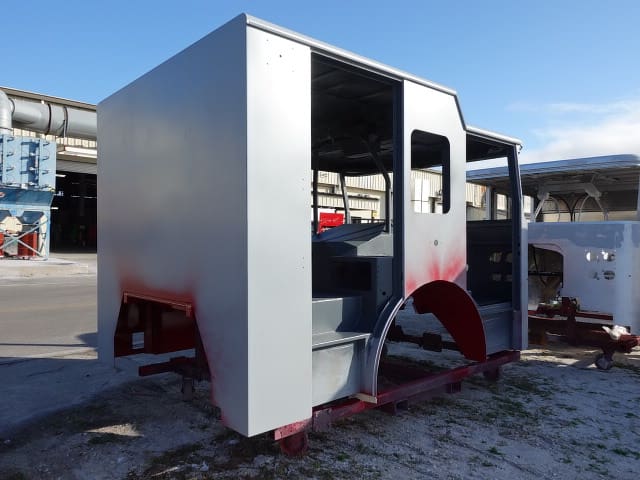

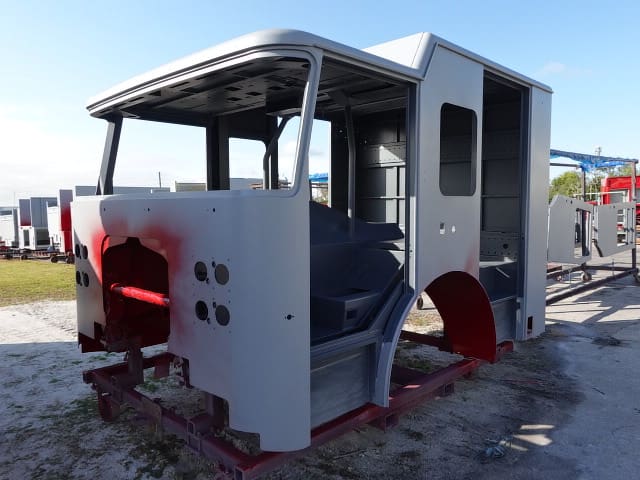

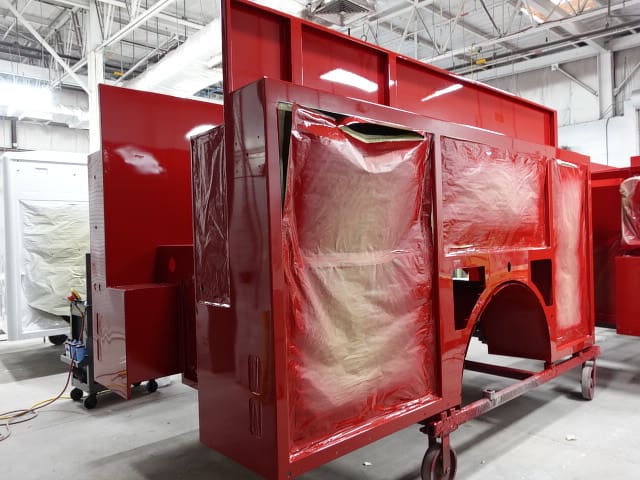

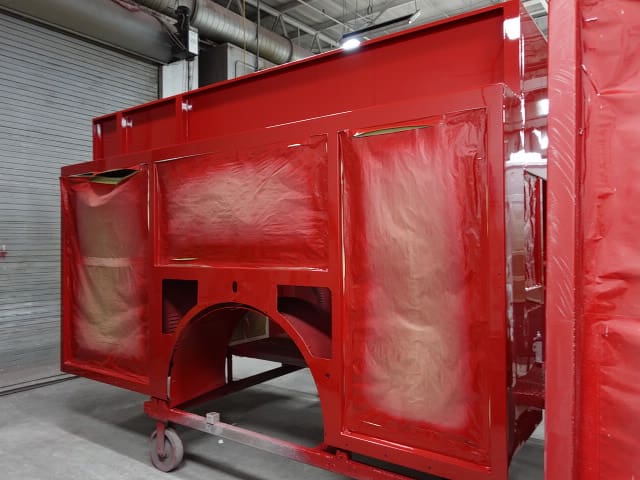

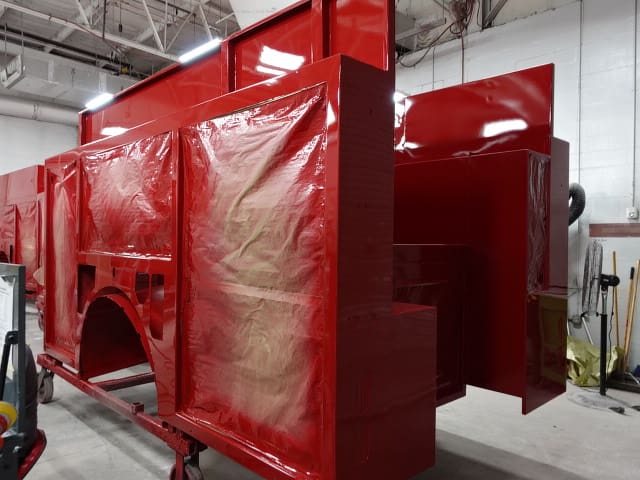

In this report, the cab began the paint process, the frame build continued (no photos), the pump house began in paint, and the body continued through paint.
01-24-25

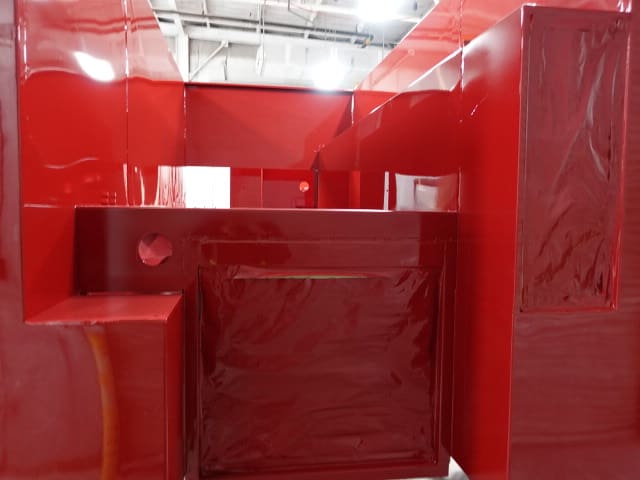

In this report, the cab continued through paint, the frame build continued, the pump house was painted and continued initial assembly, and the body continued the paint process.

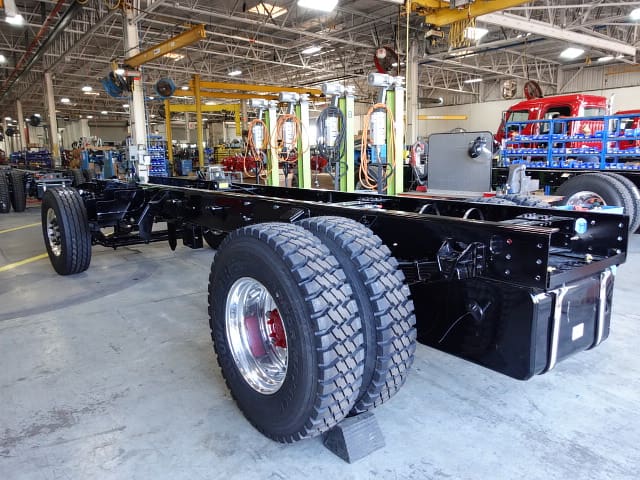

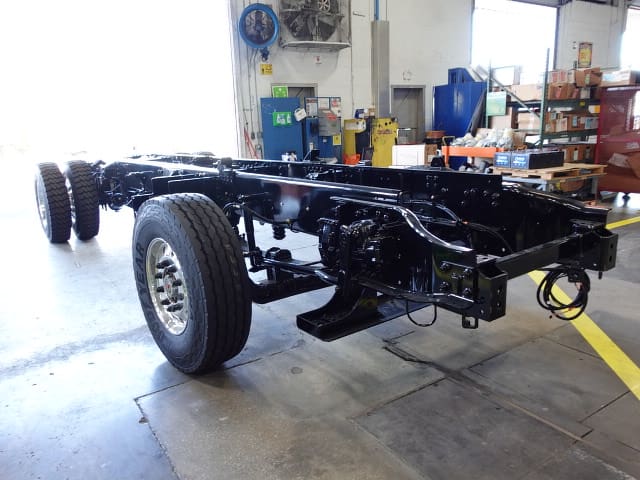

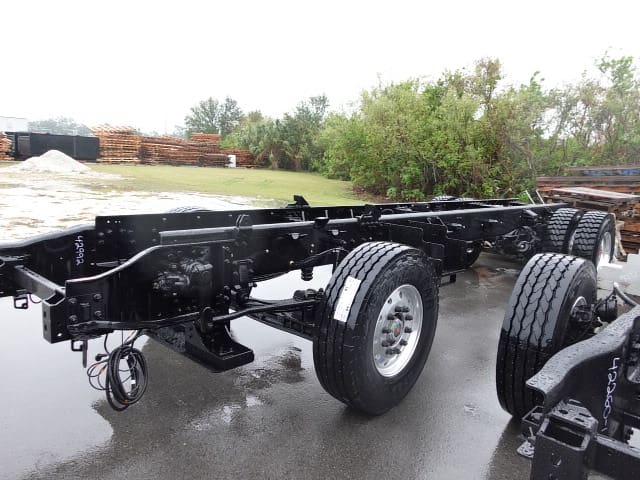

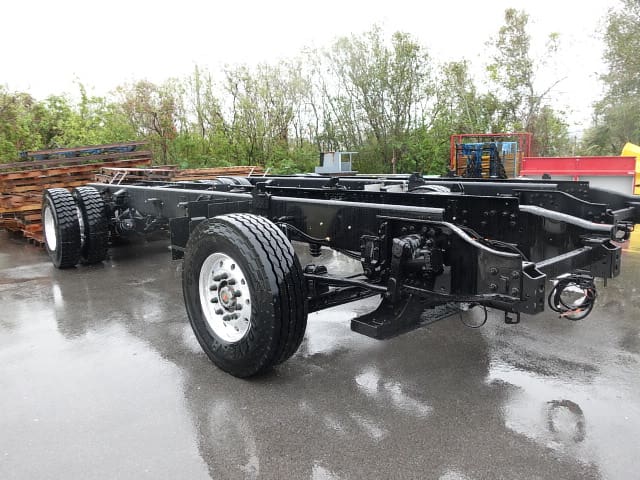

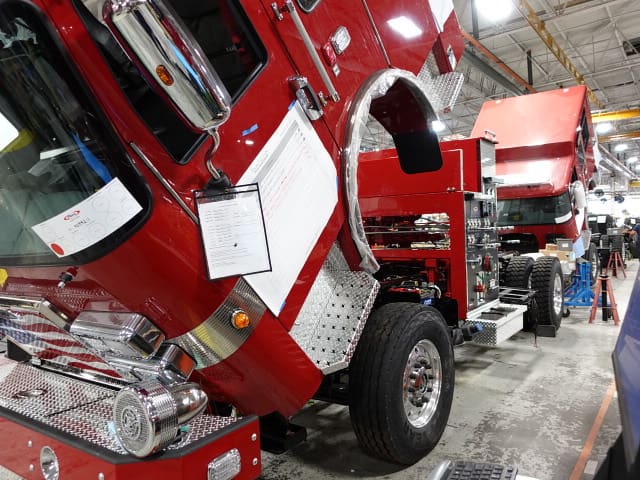

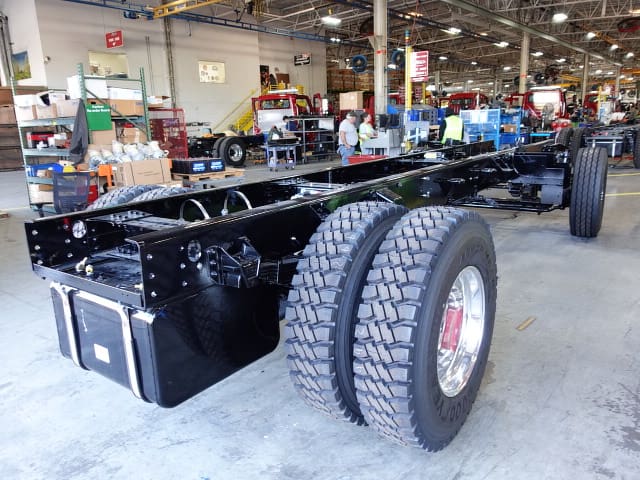

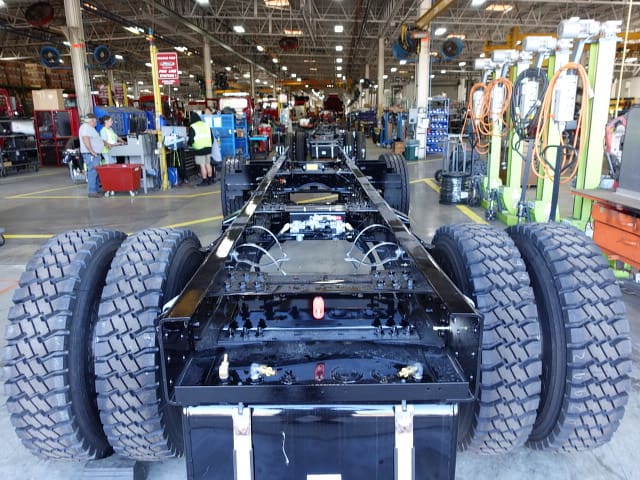

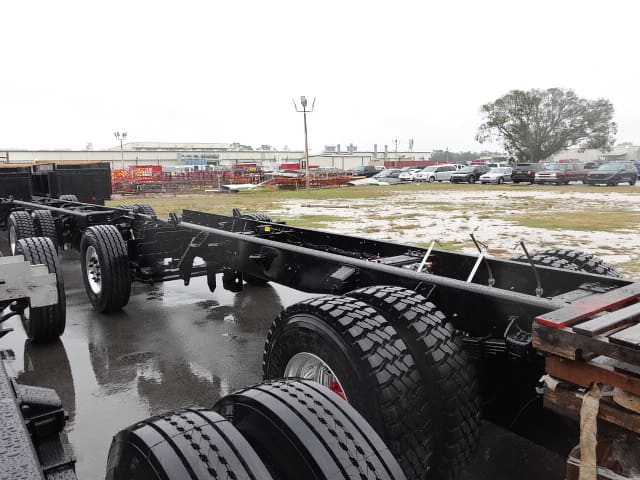

01-10-25

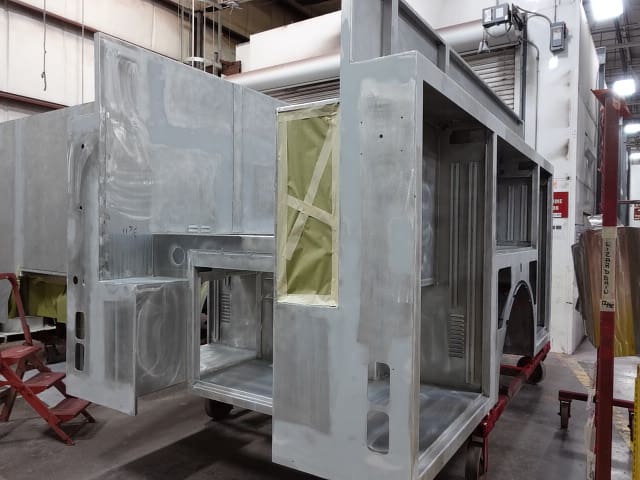

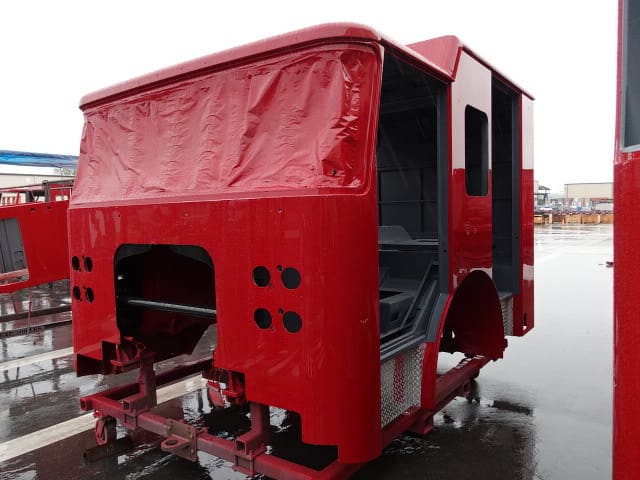

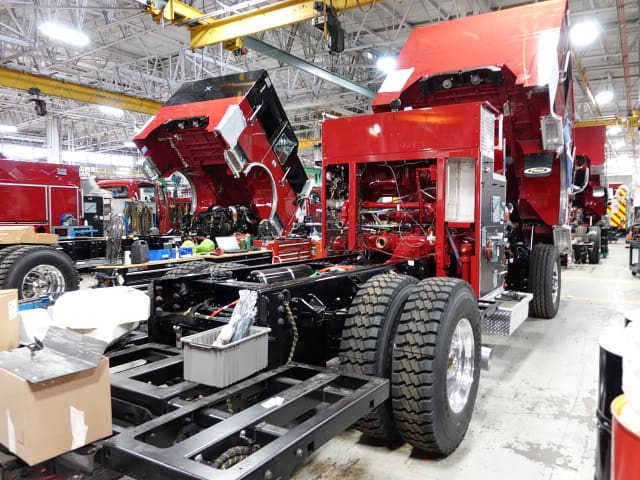

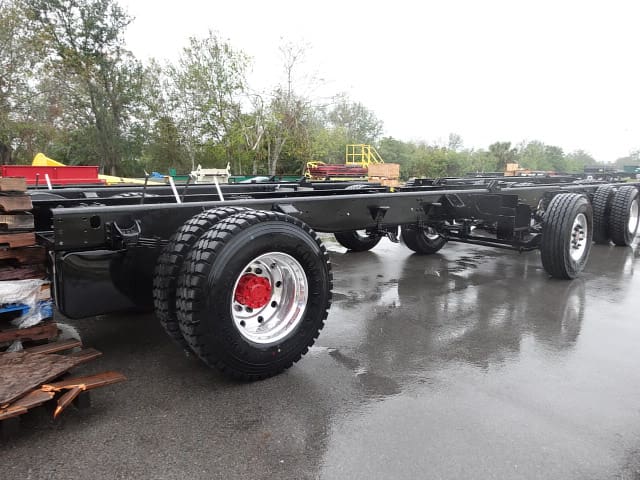

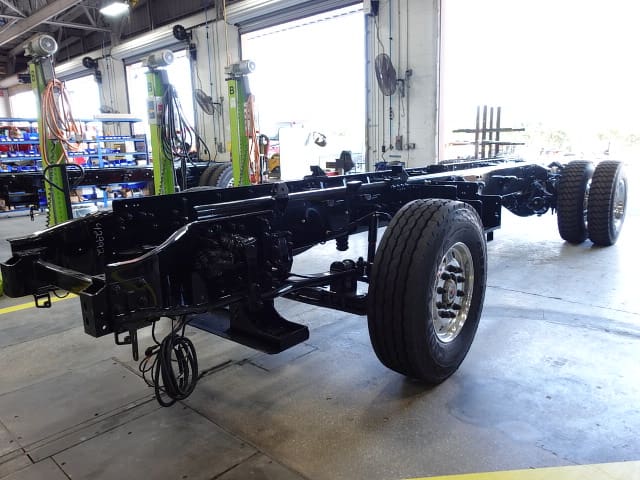

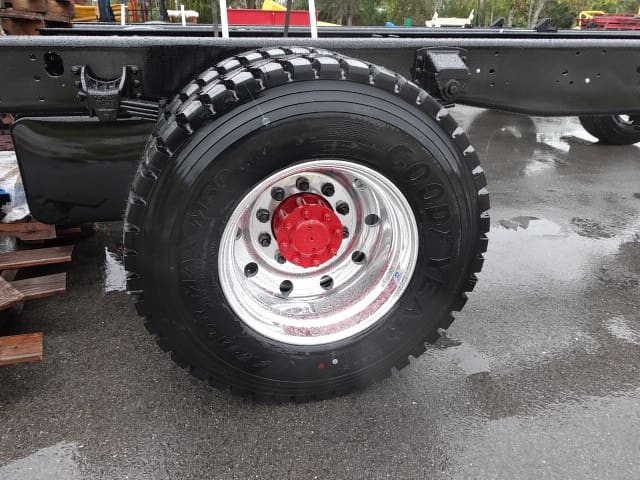

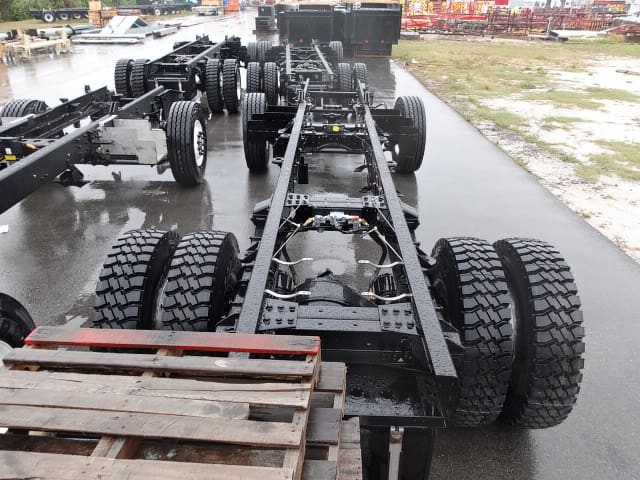

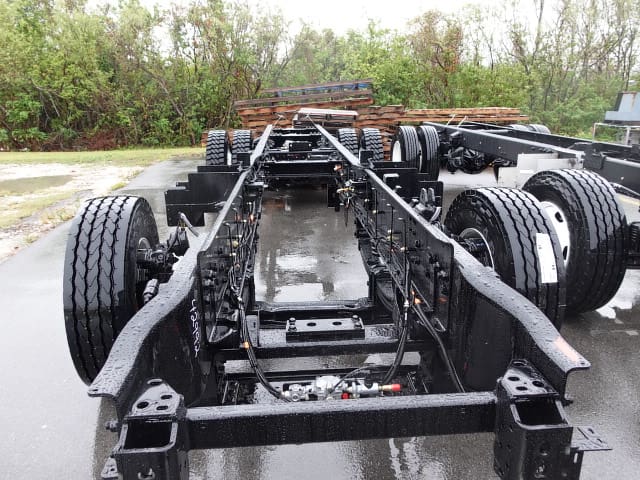

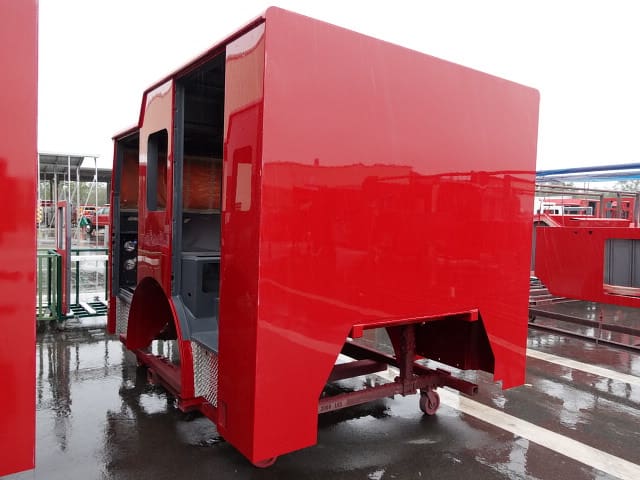

In this report, the cab completed fabrication, the frame build began, the pump house continued initial assembly, and the body completed fabrication and began the paint process.
