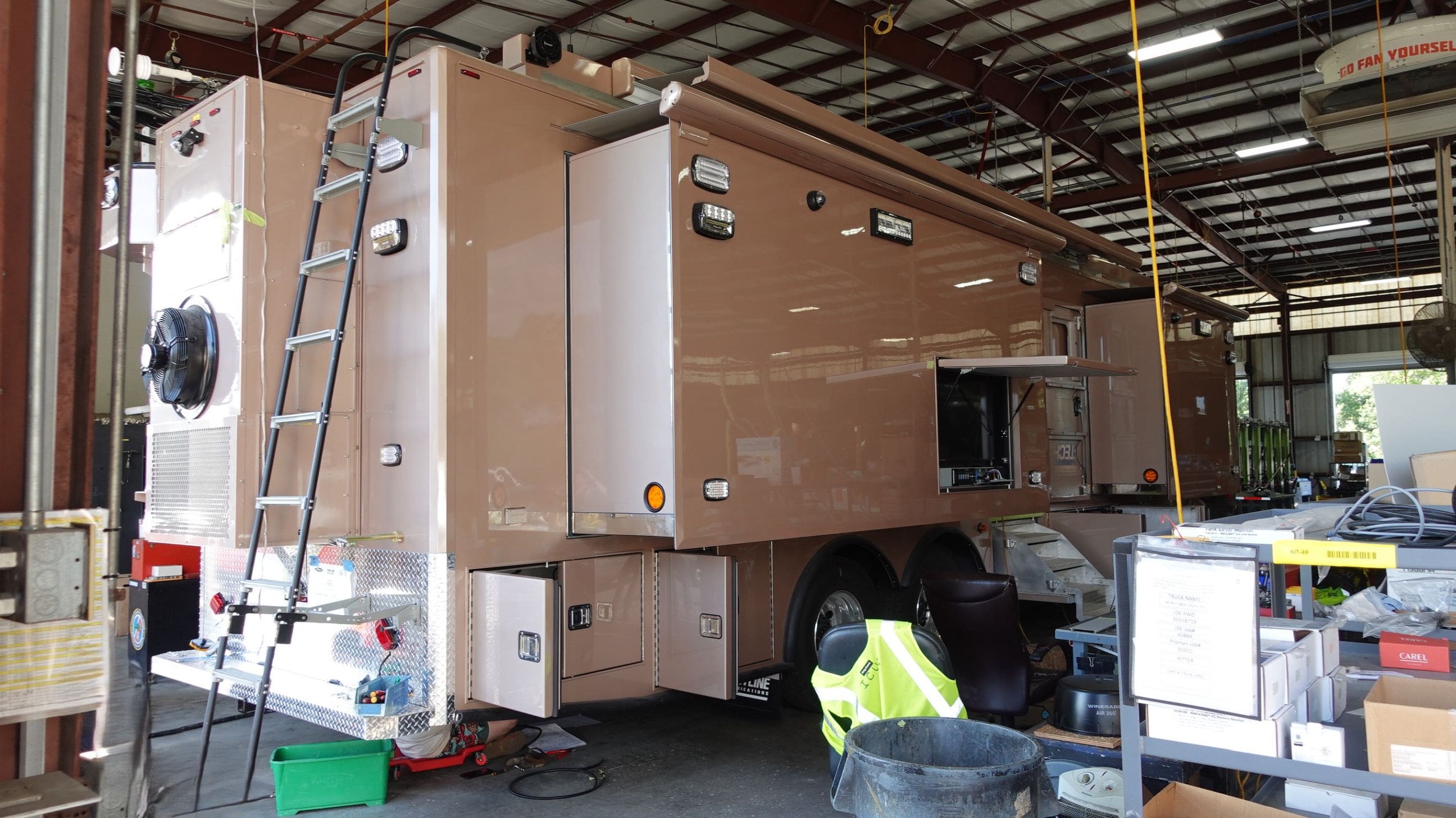

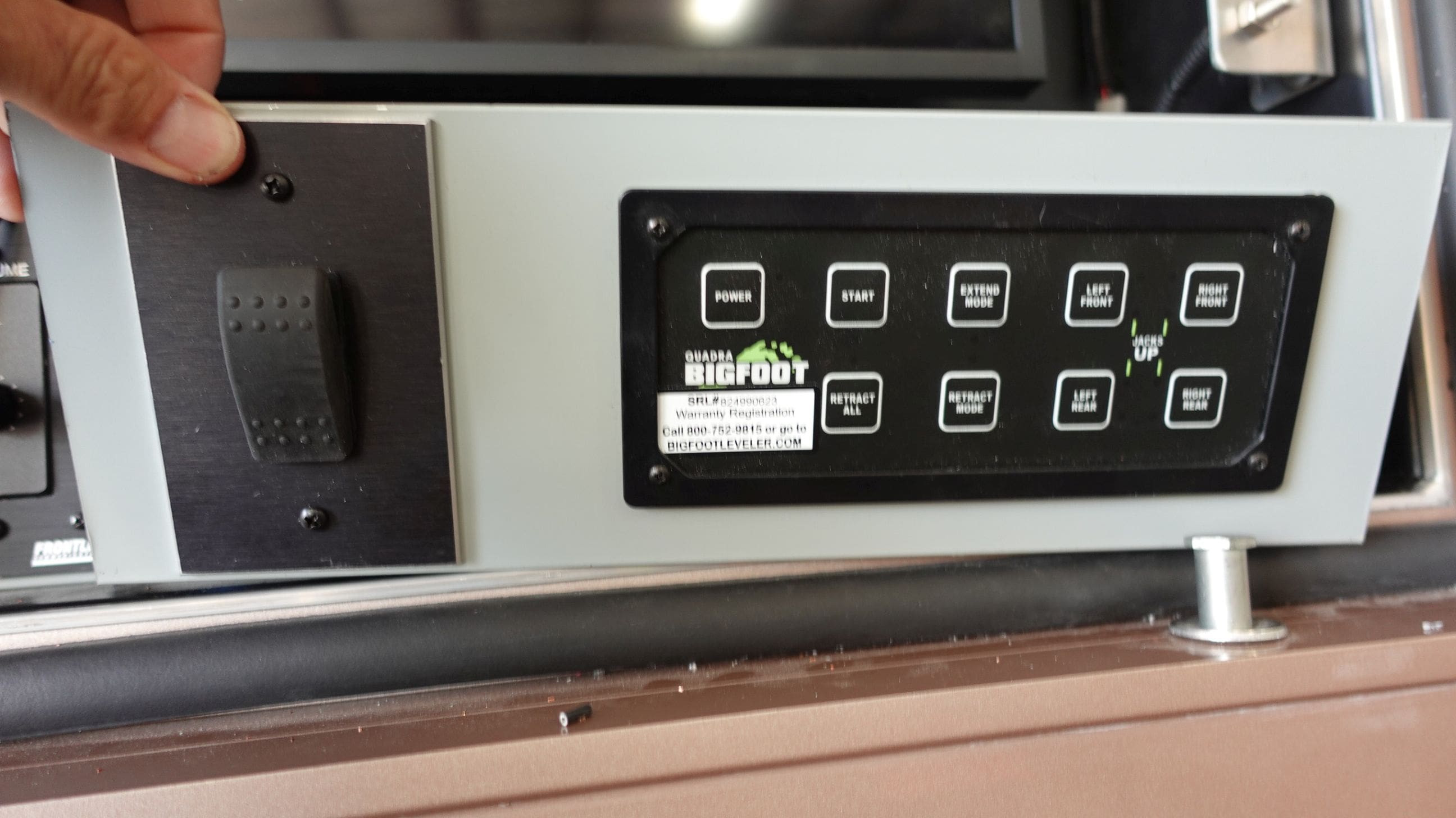

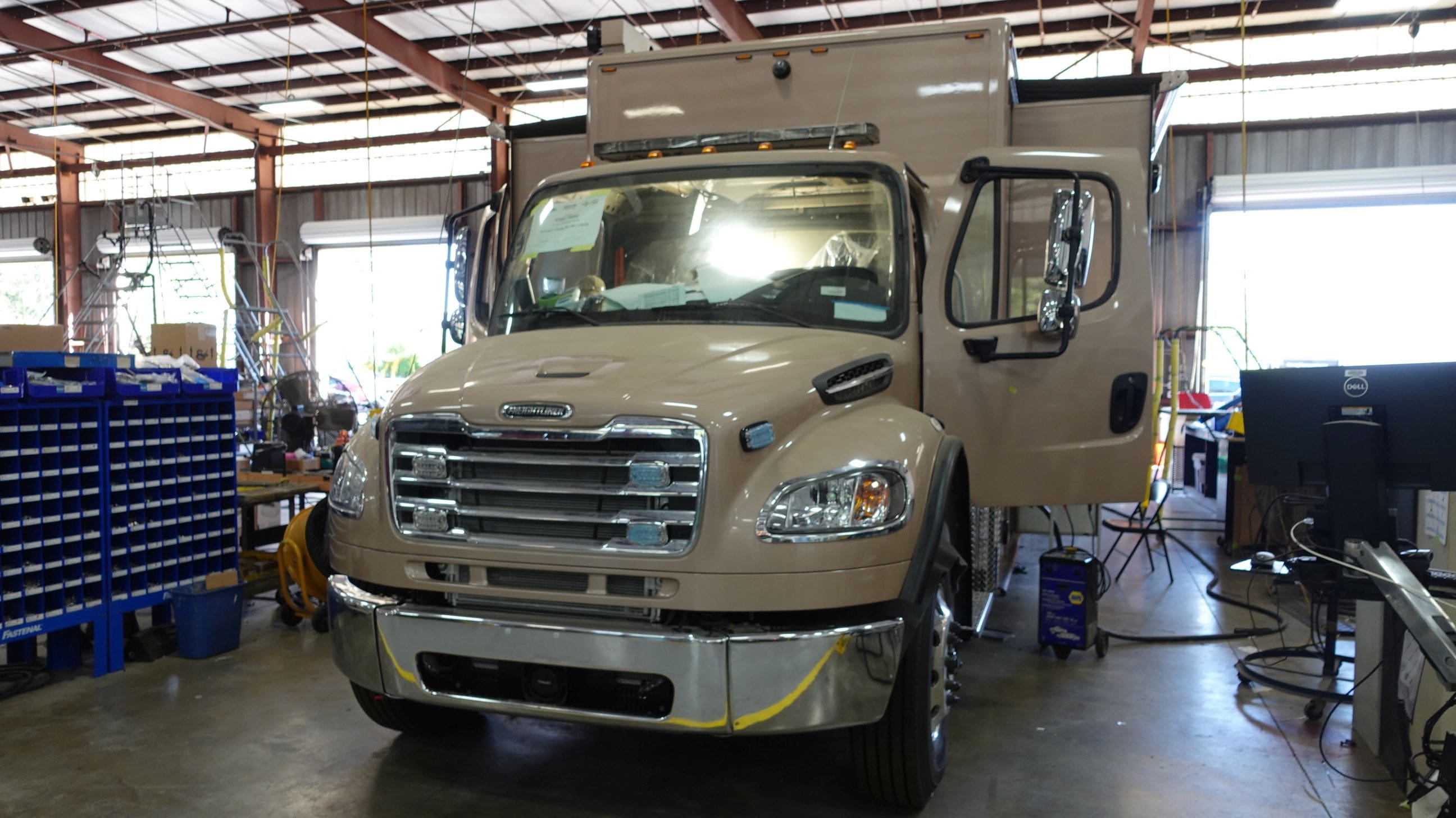

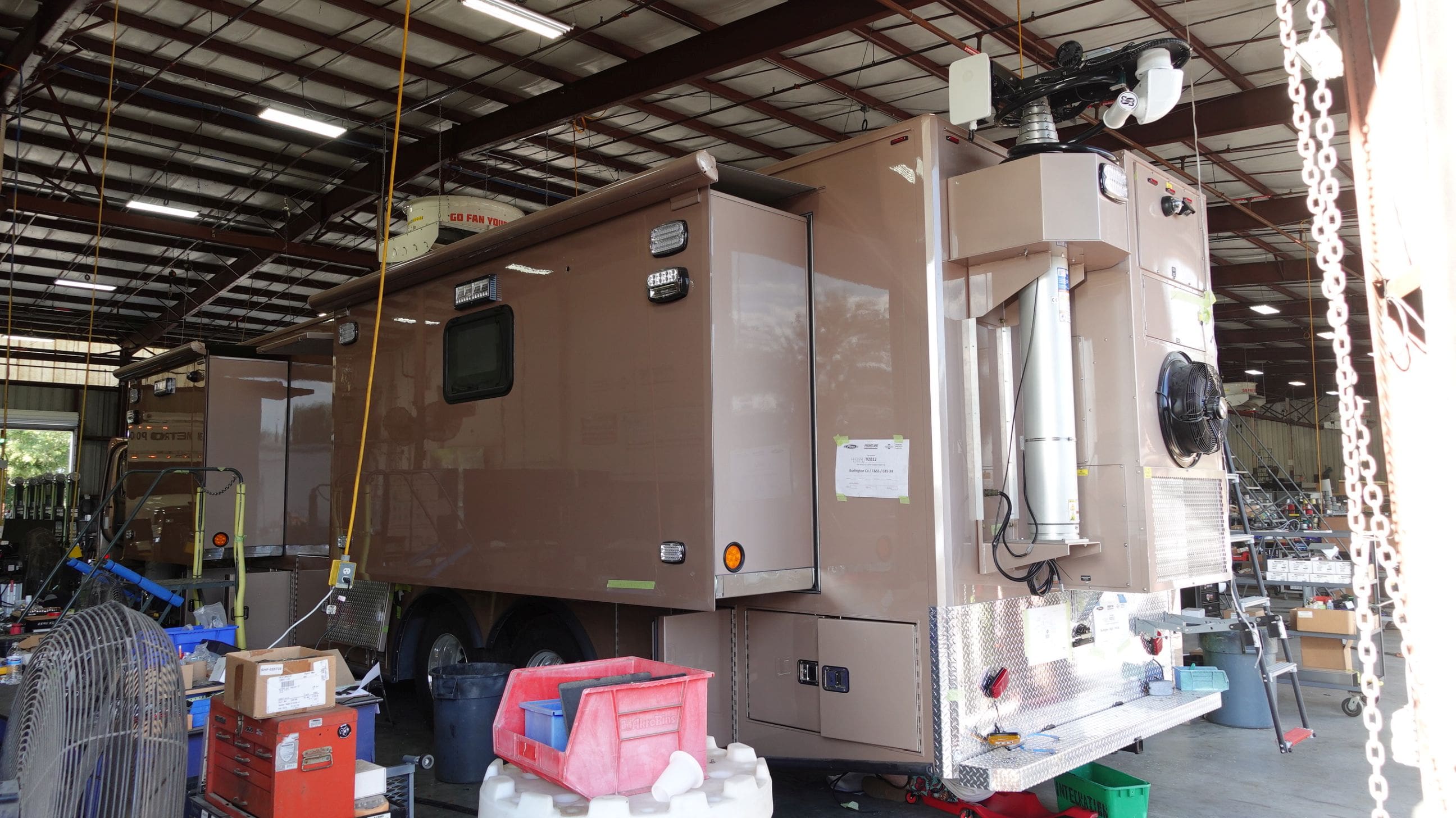

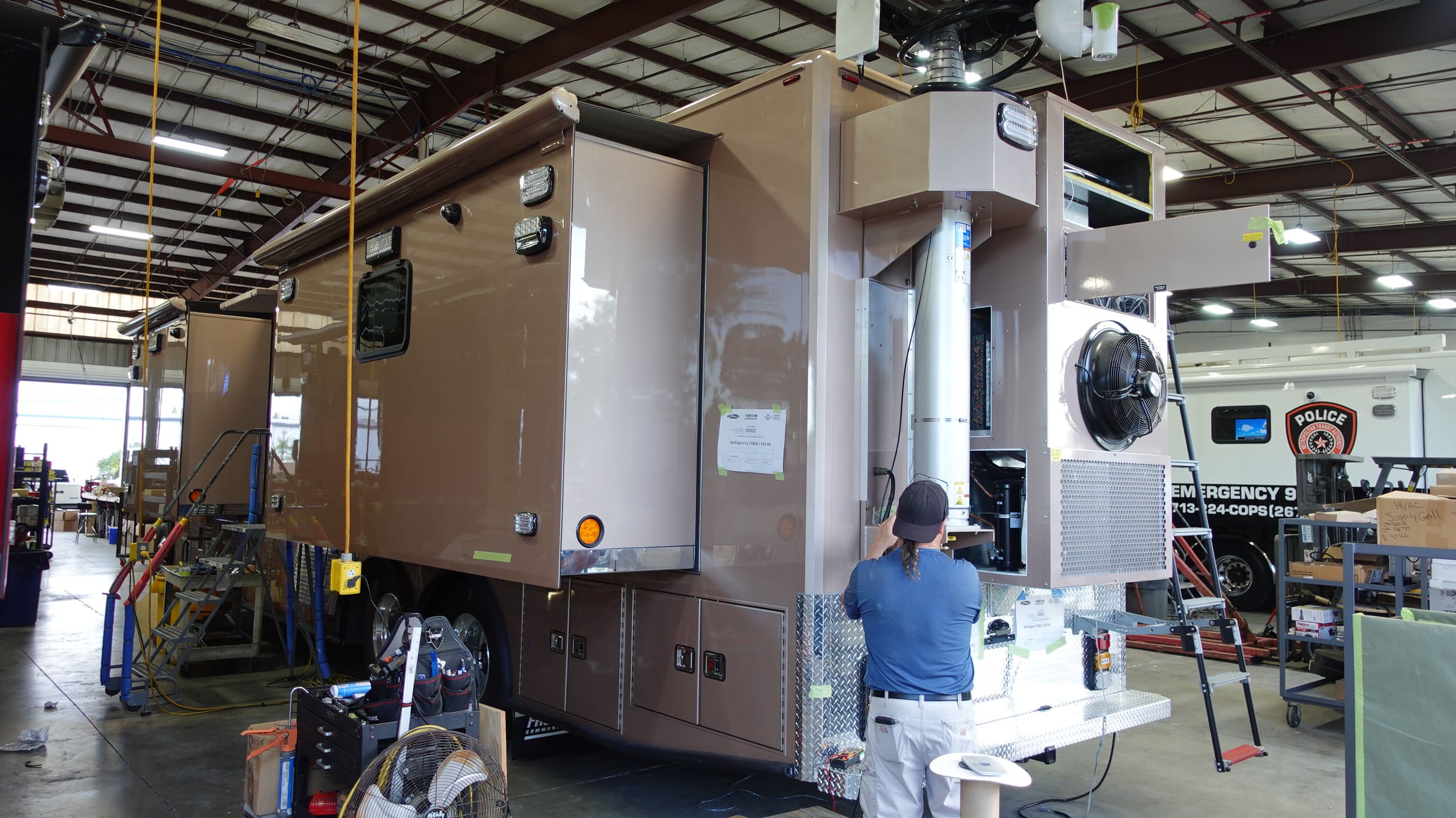

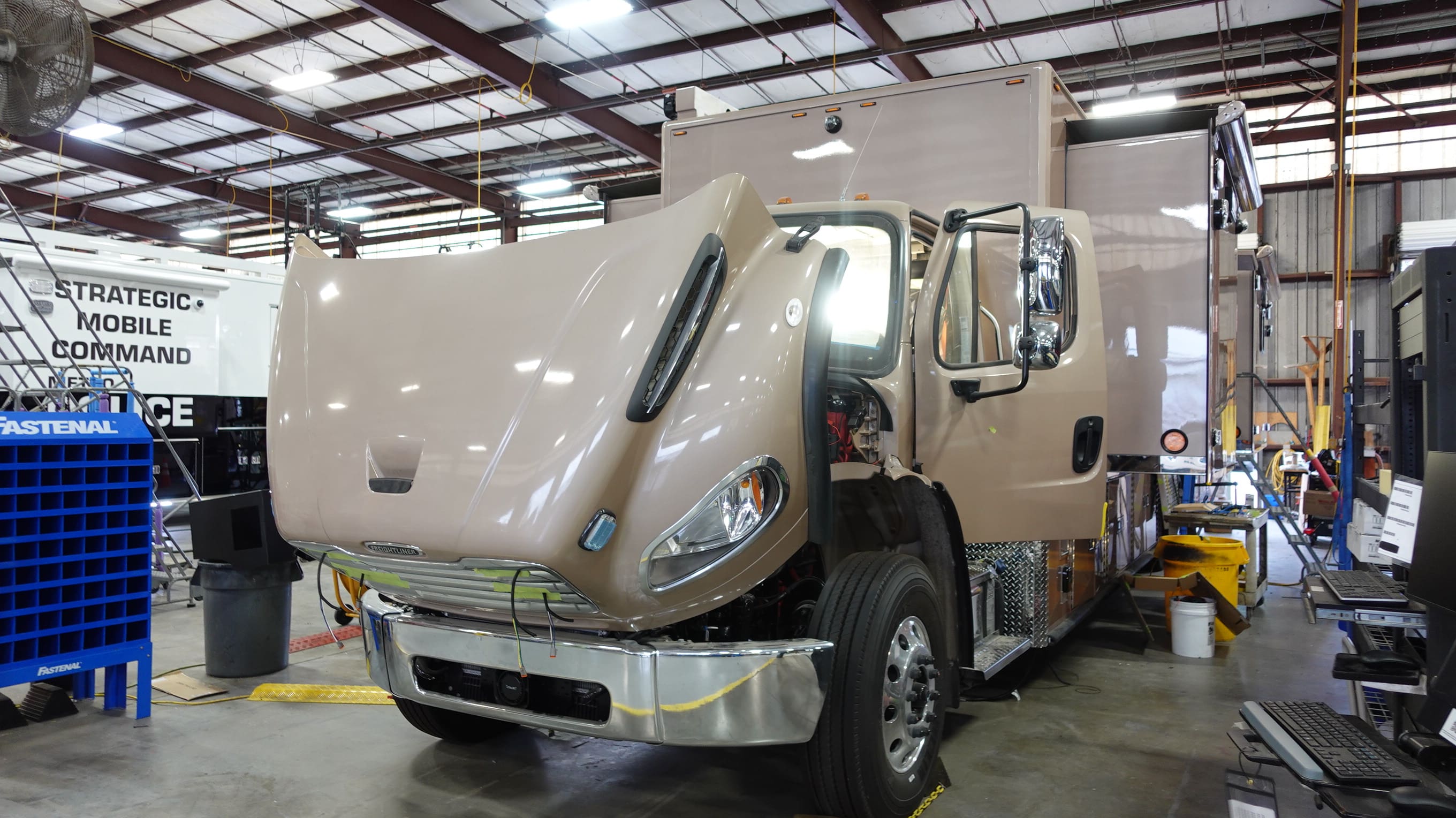

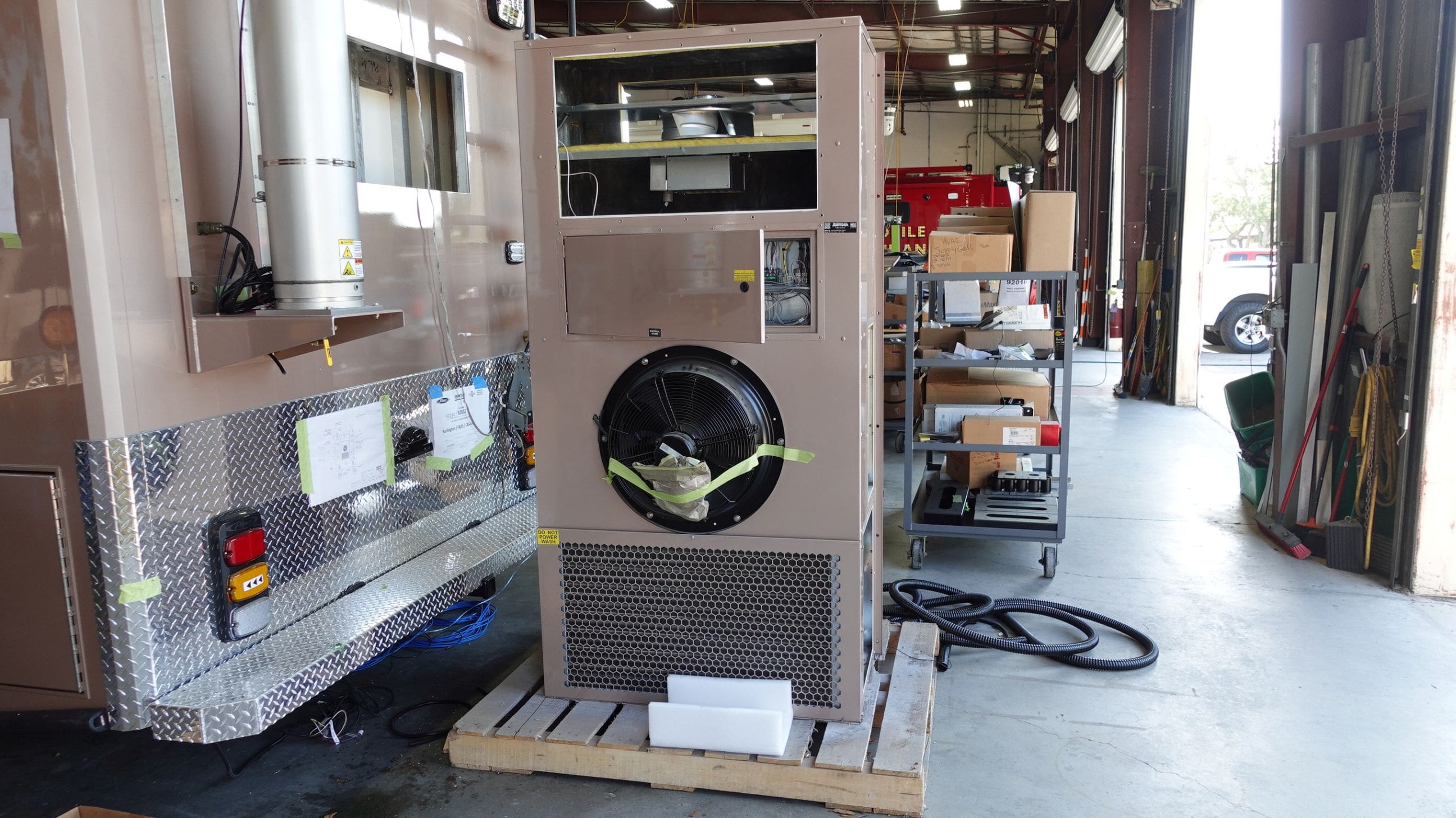

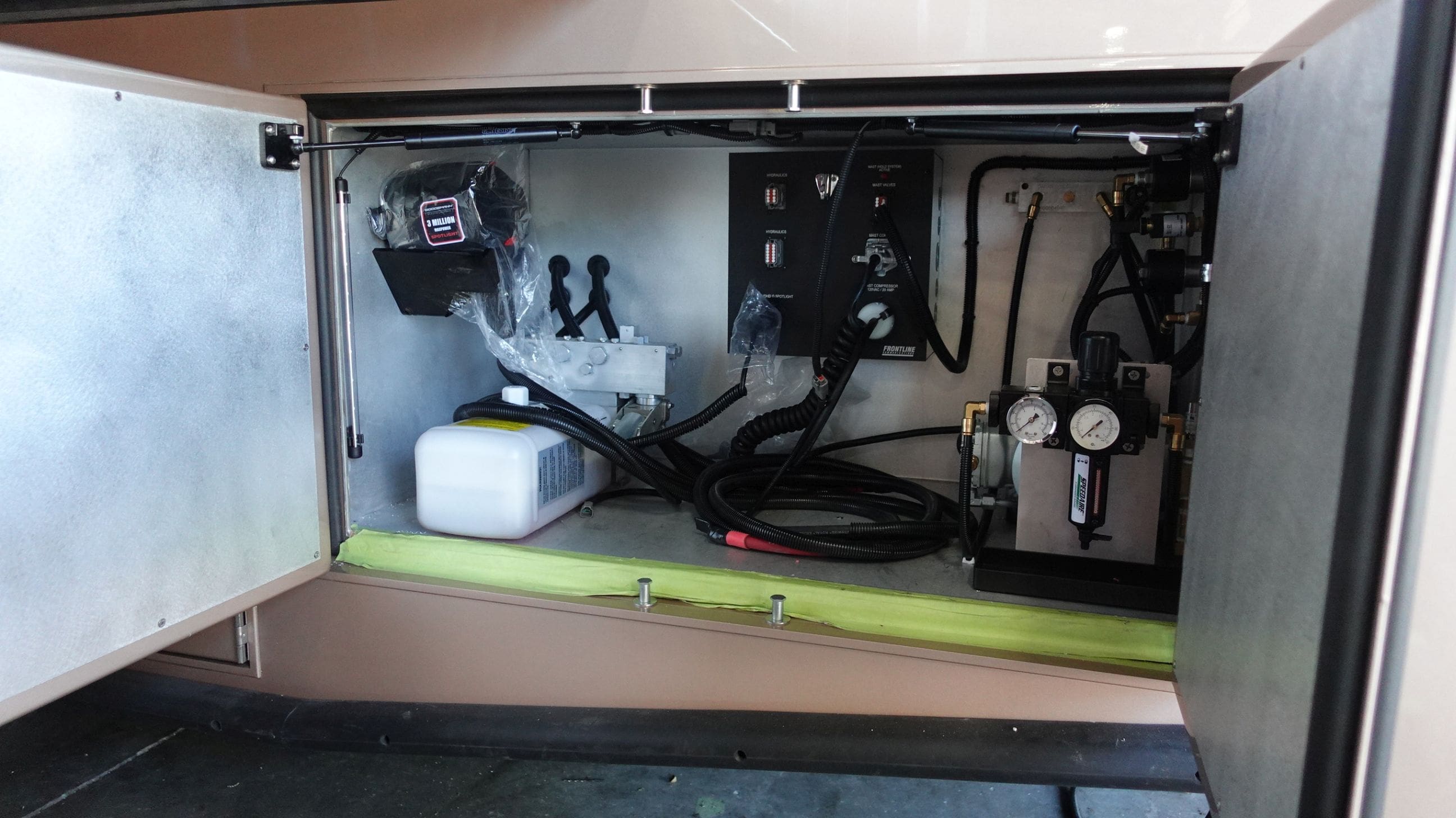

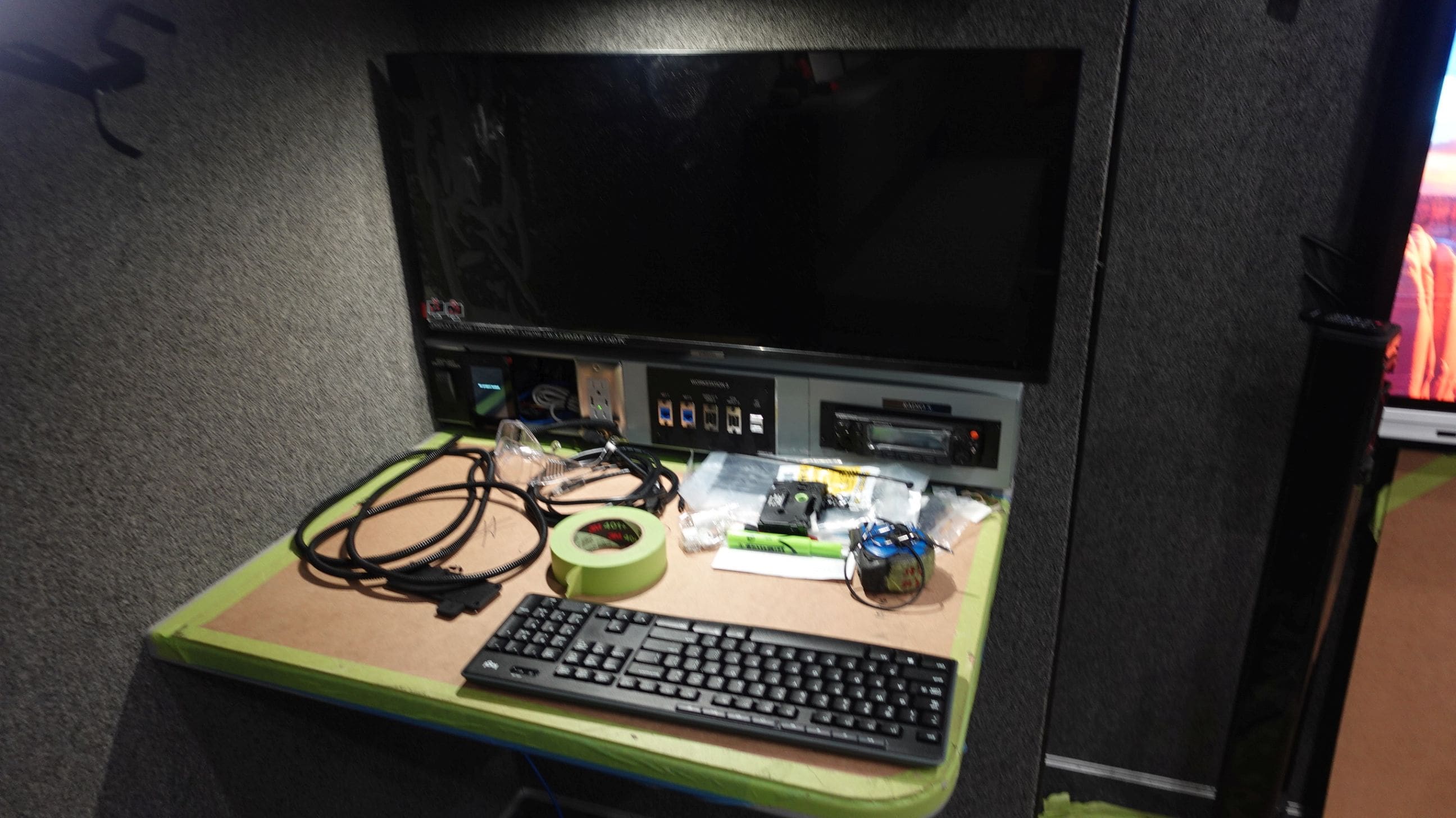

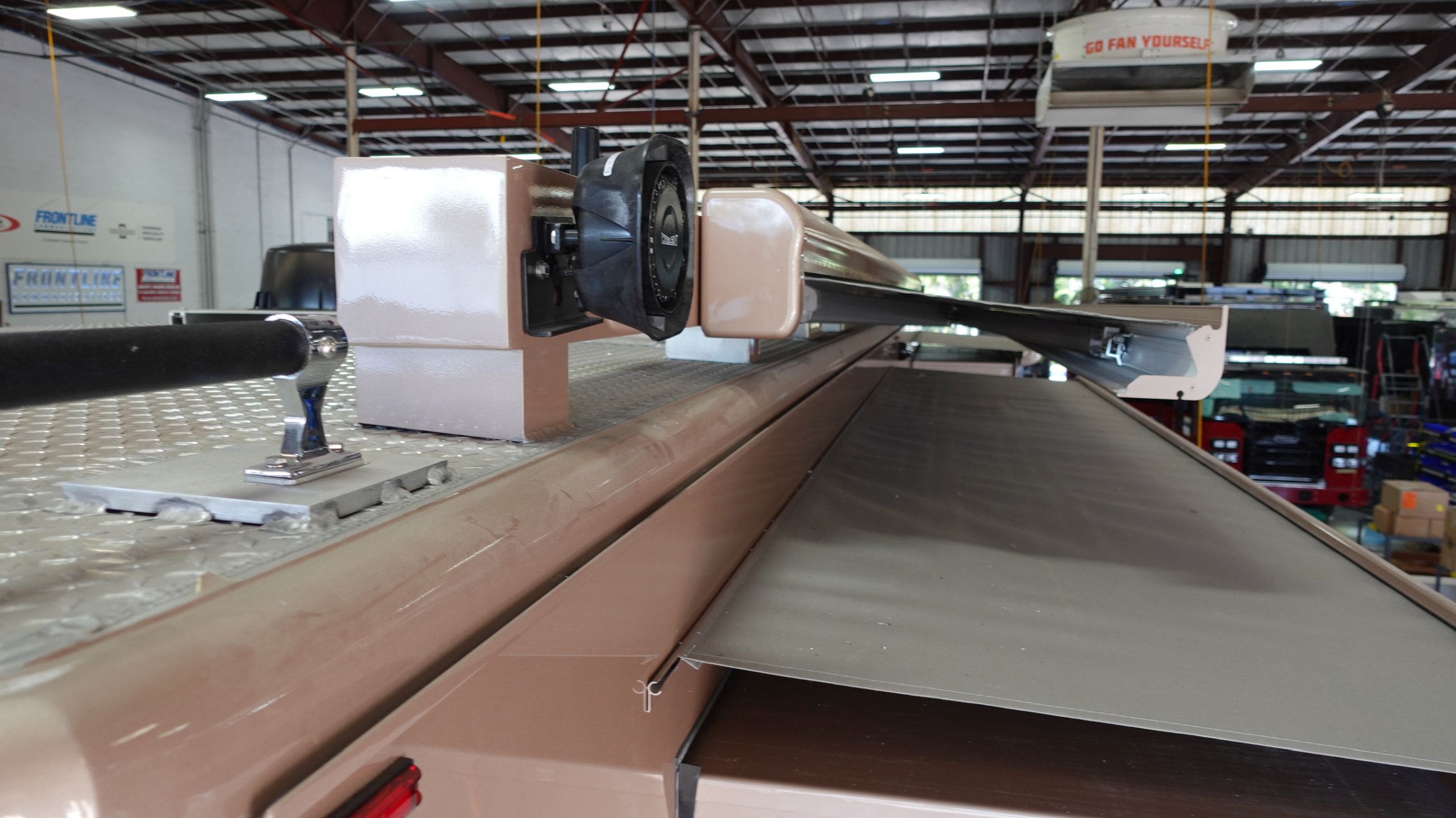

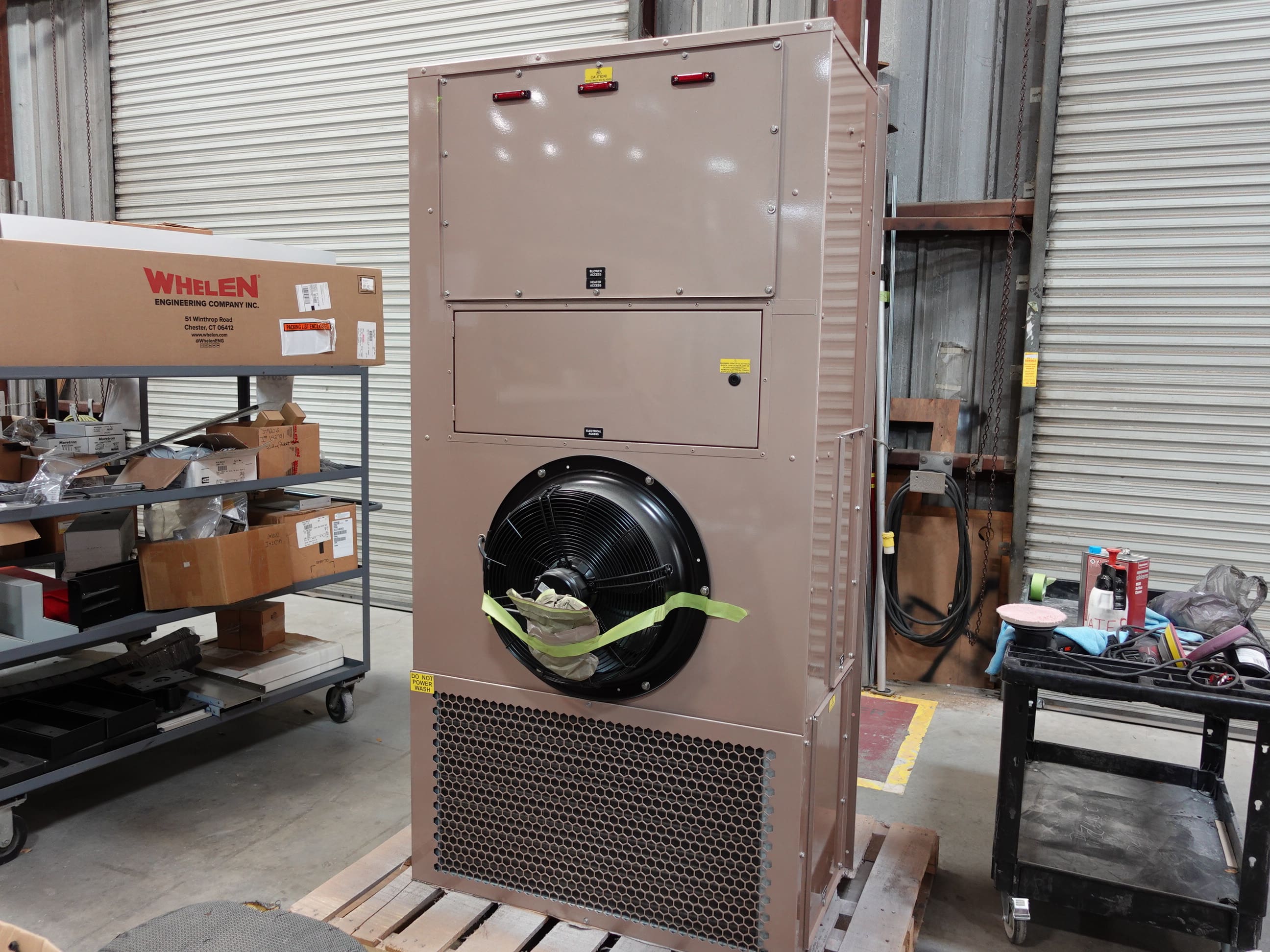

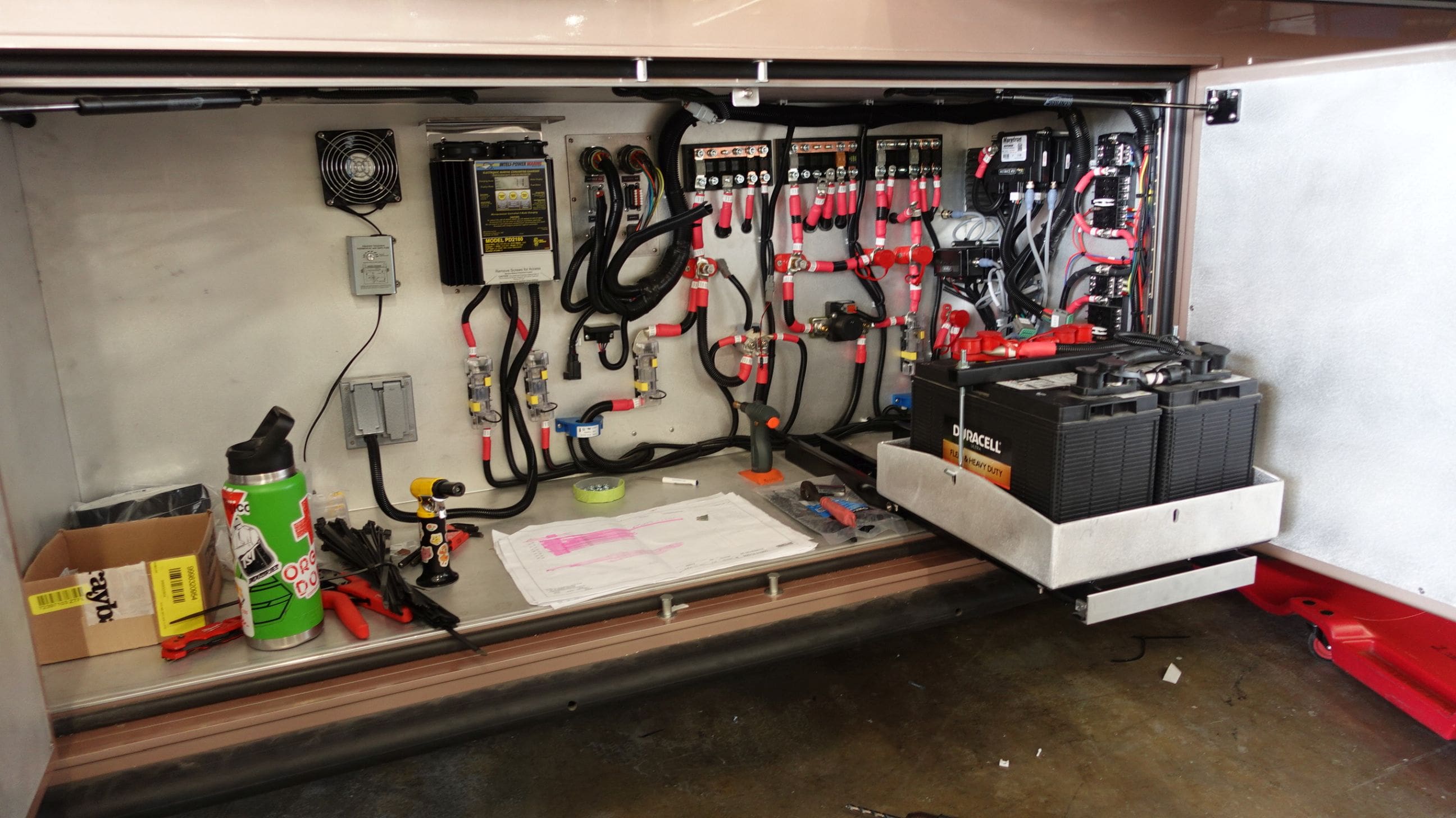

06-05-26

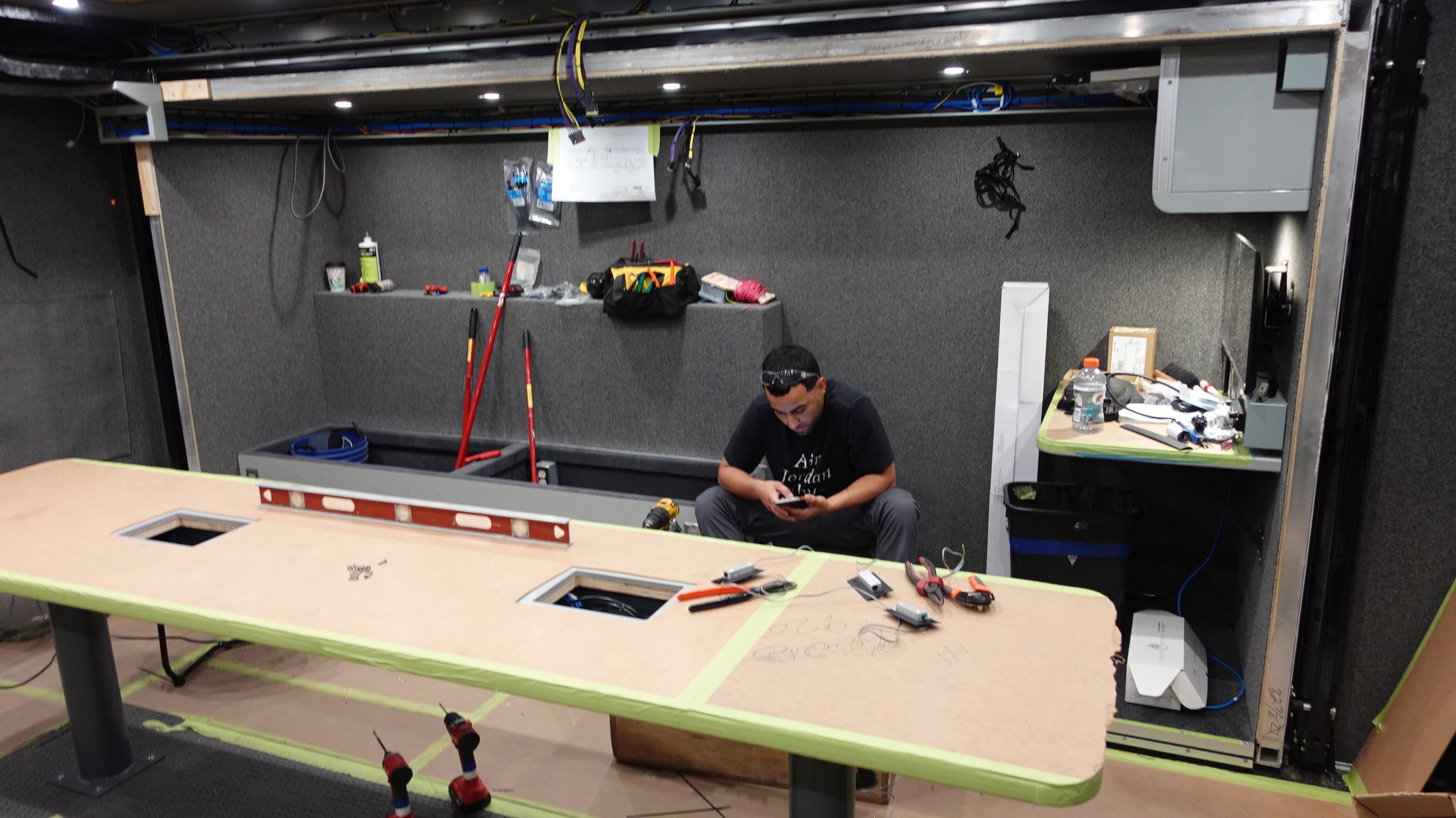

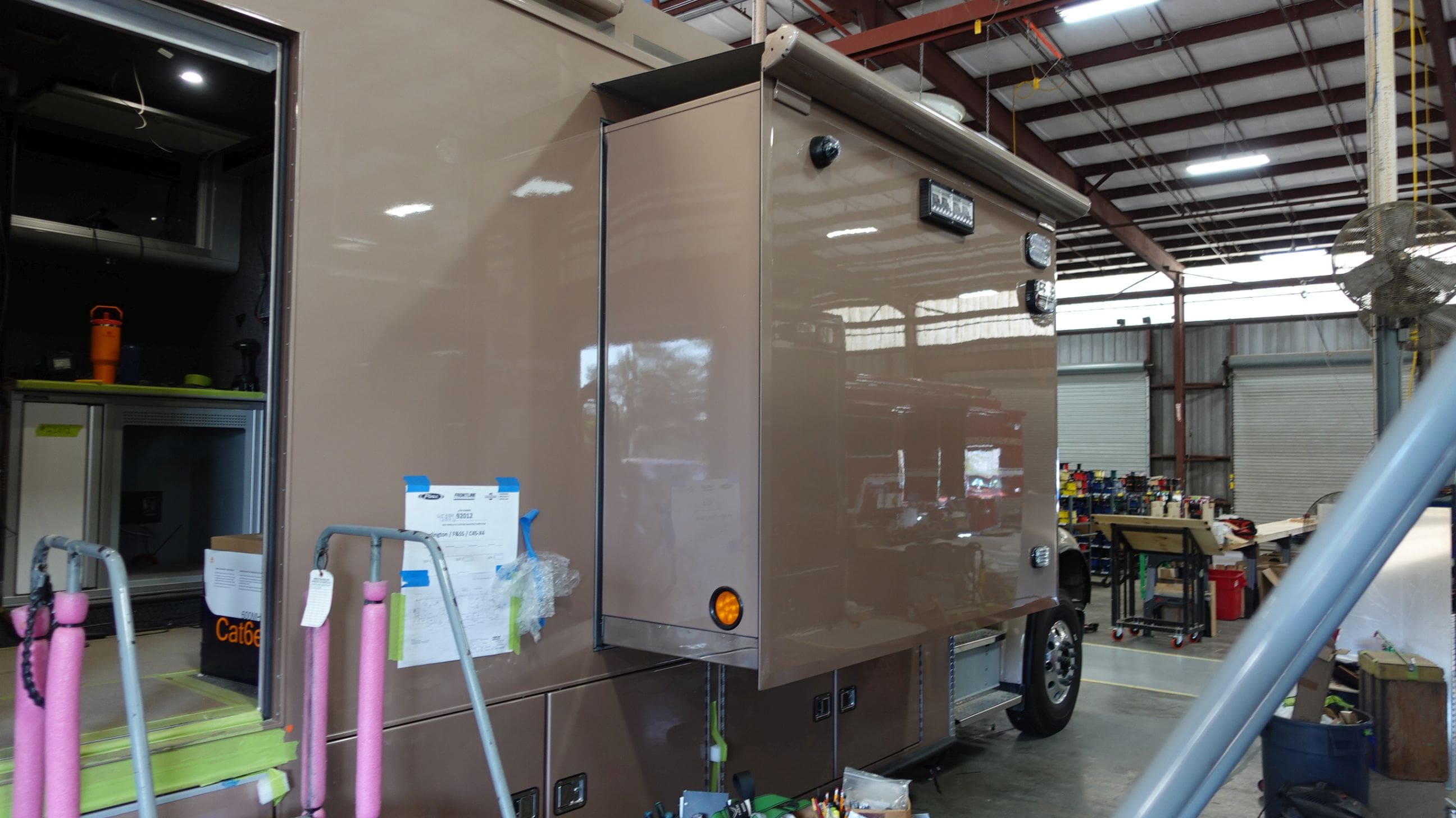

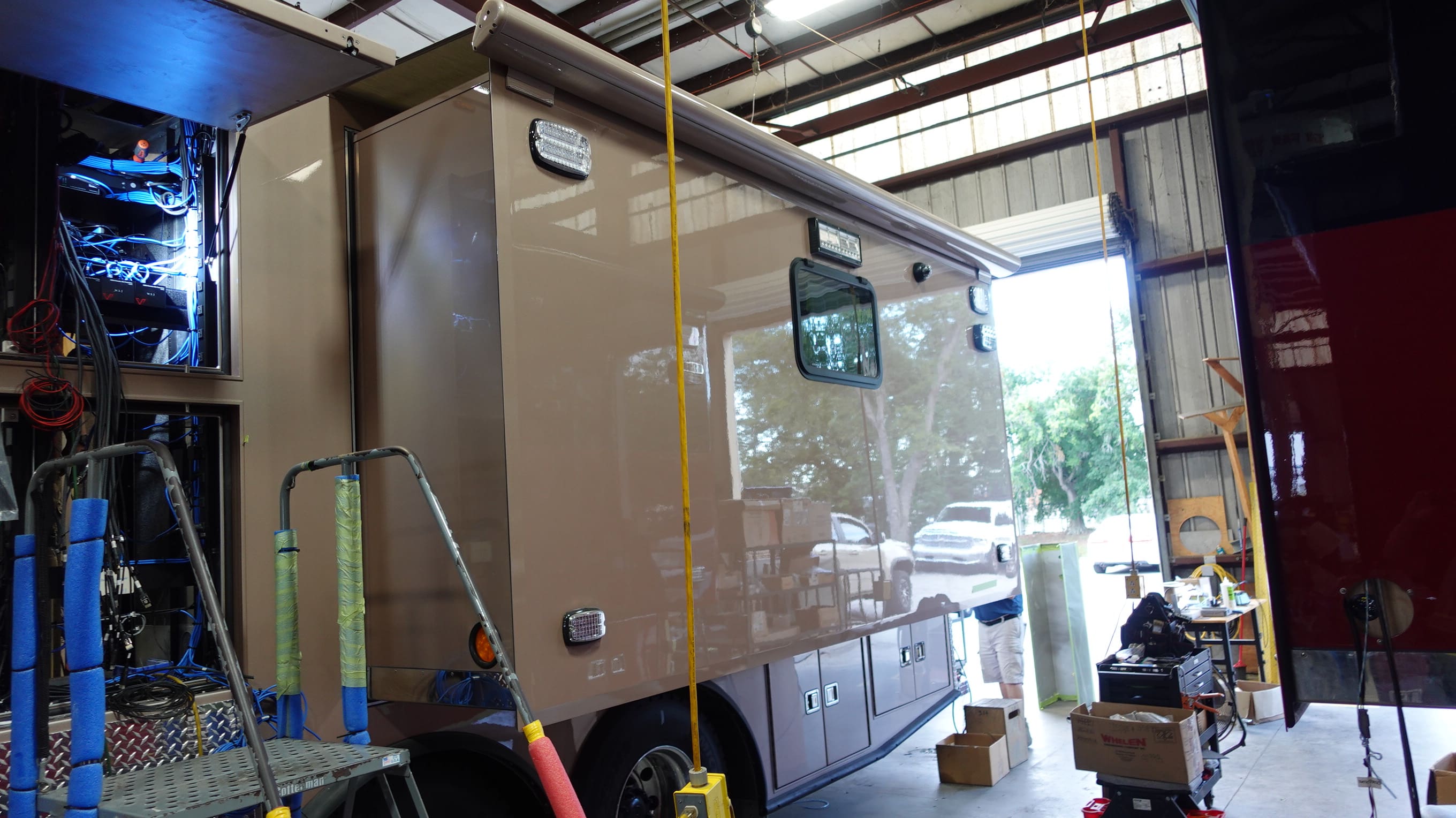

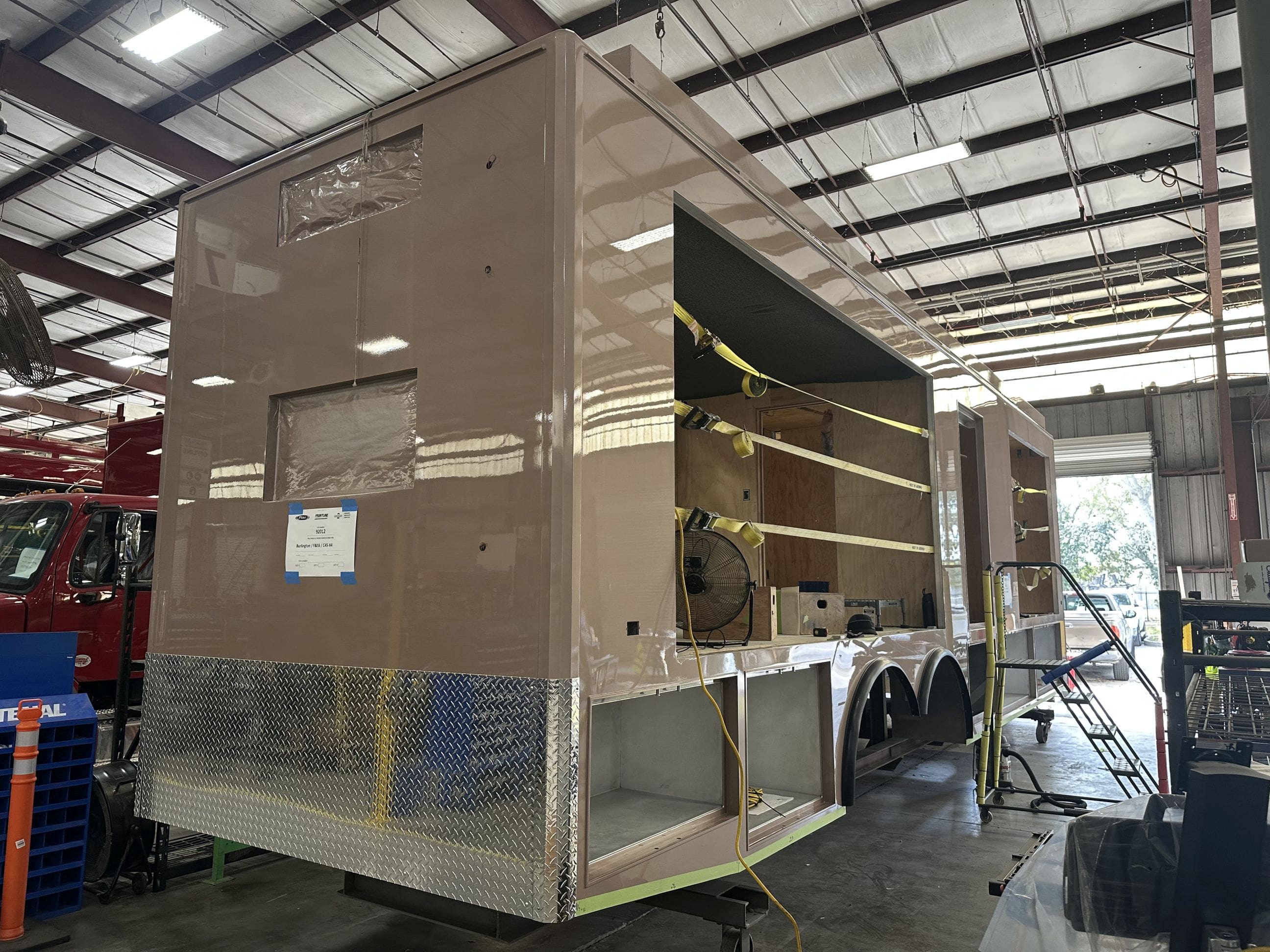

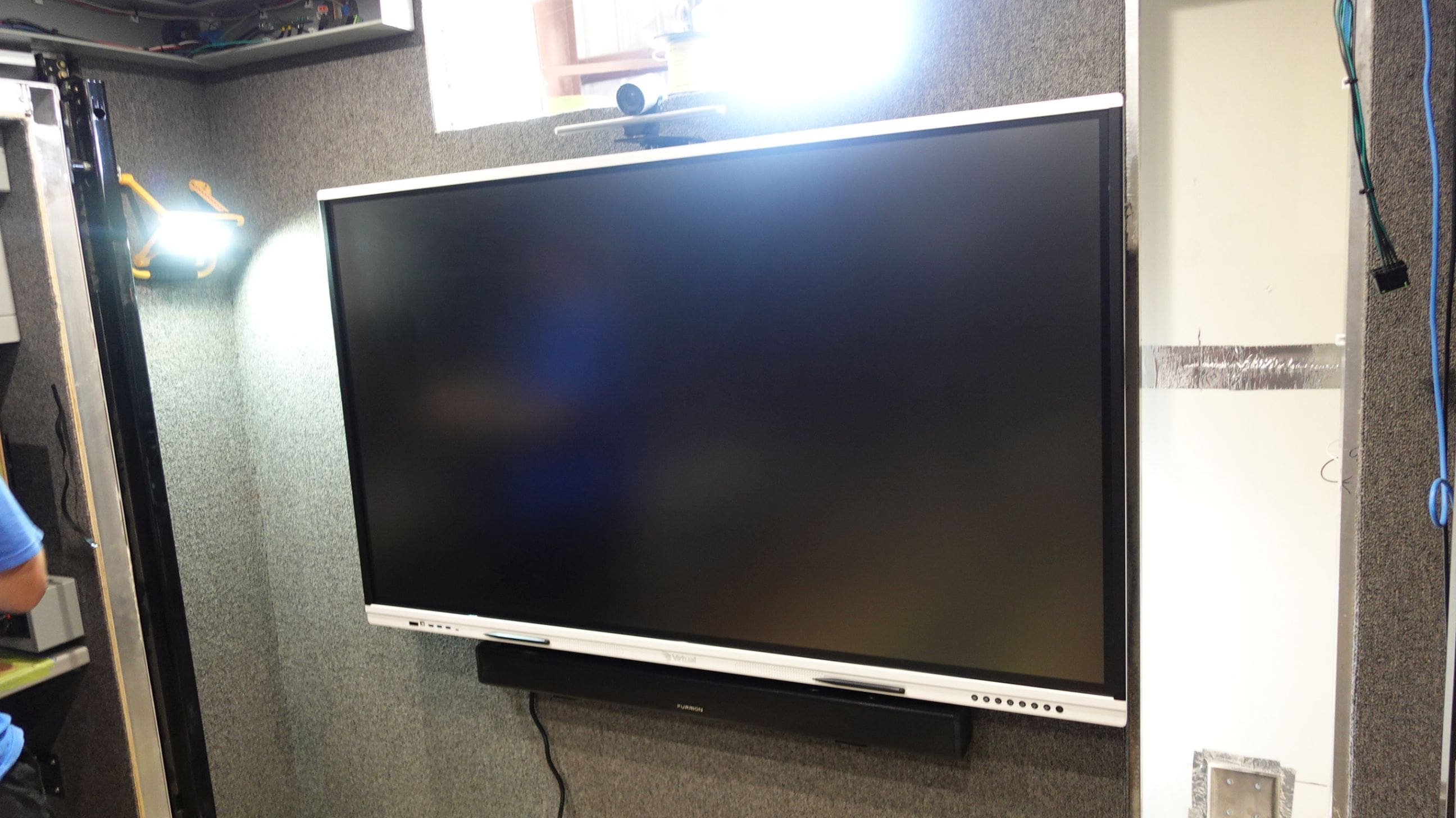

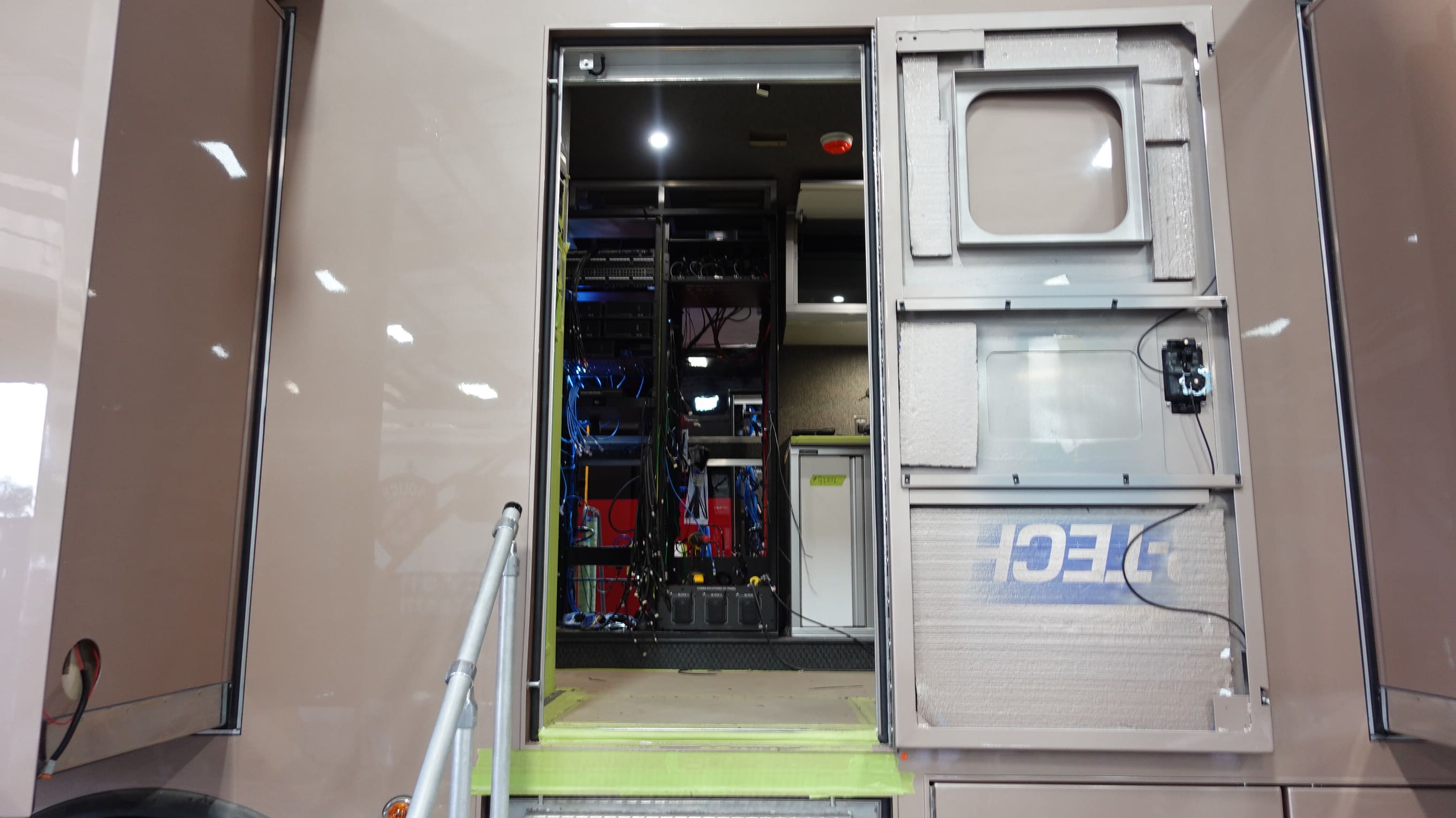

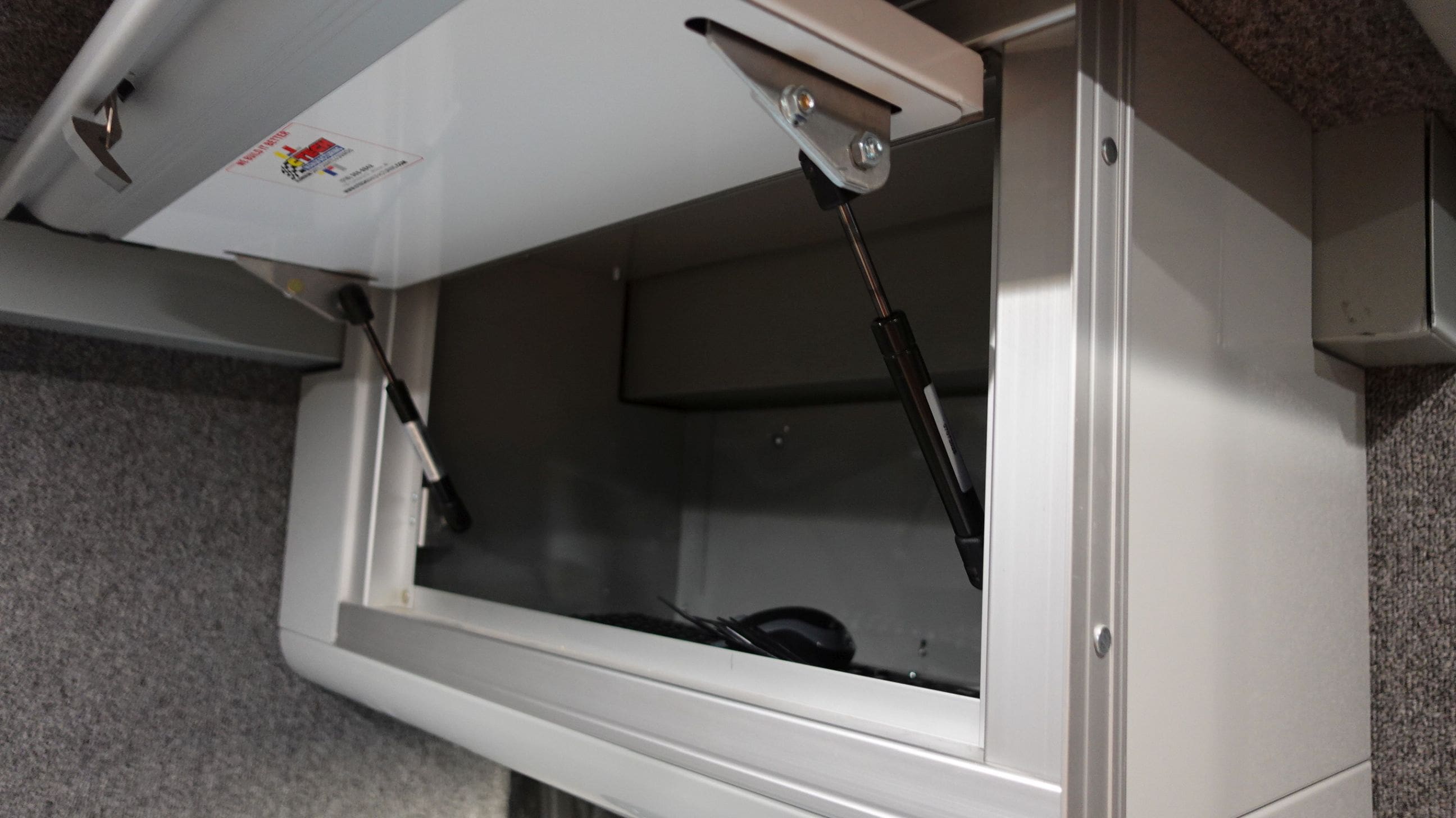

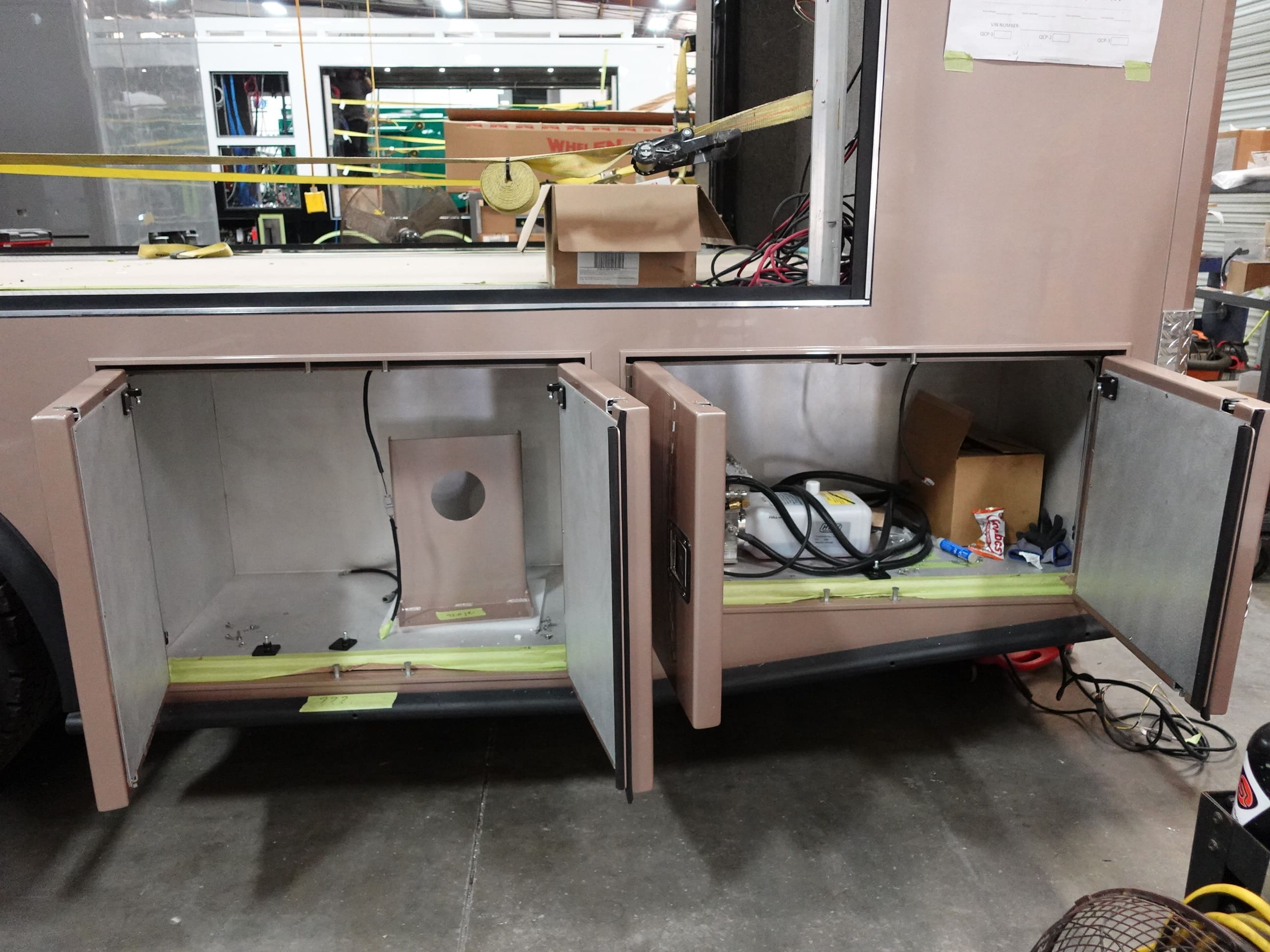

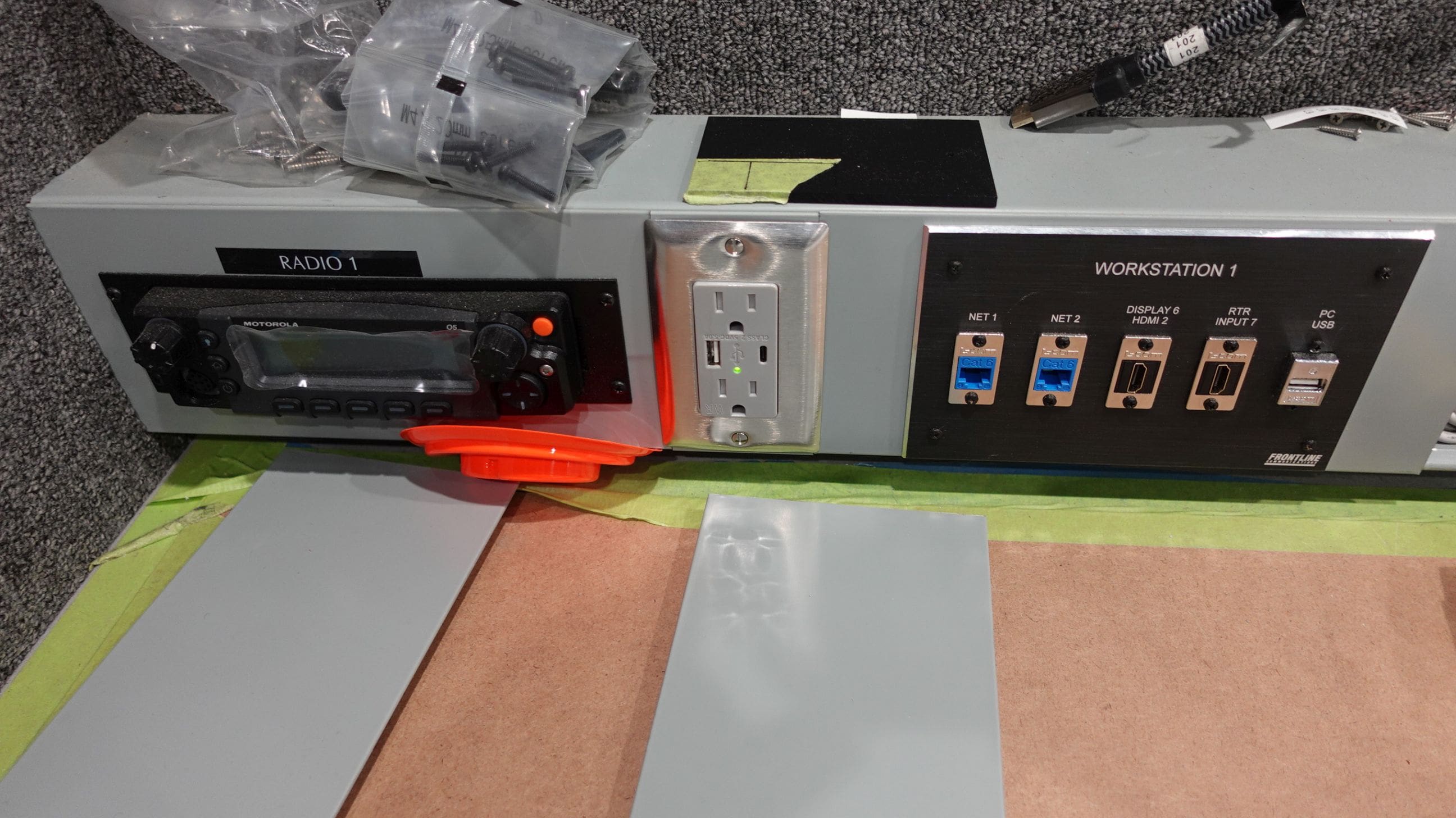

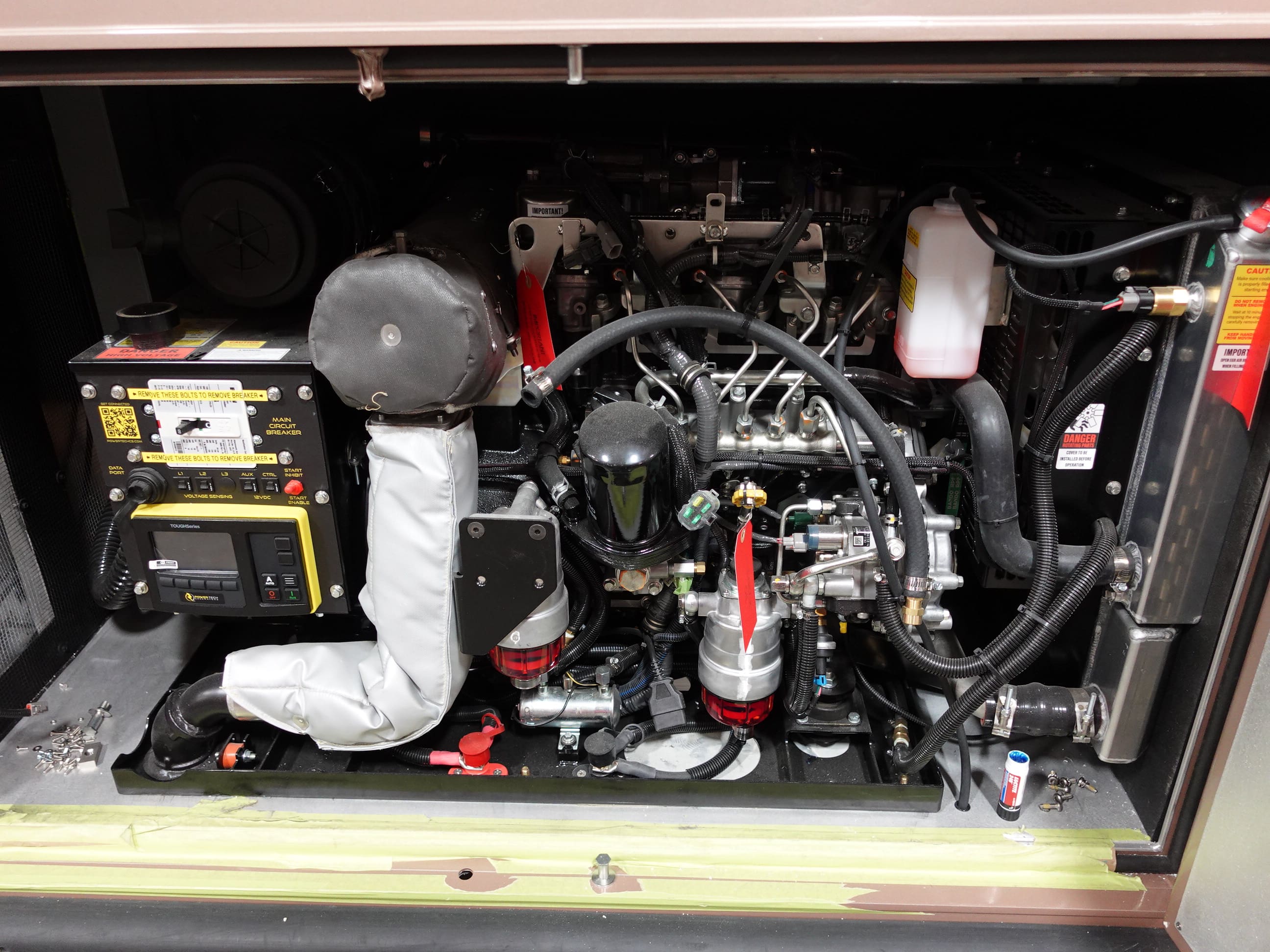

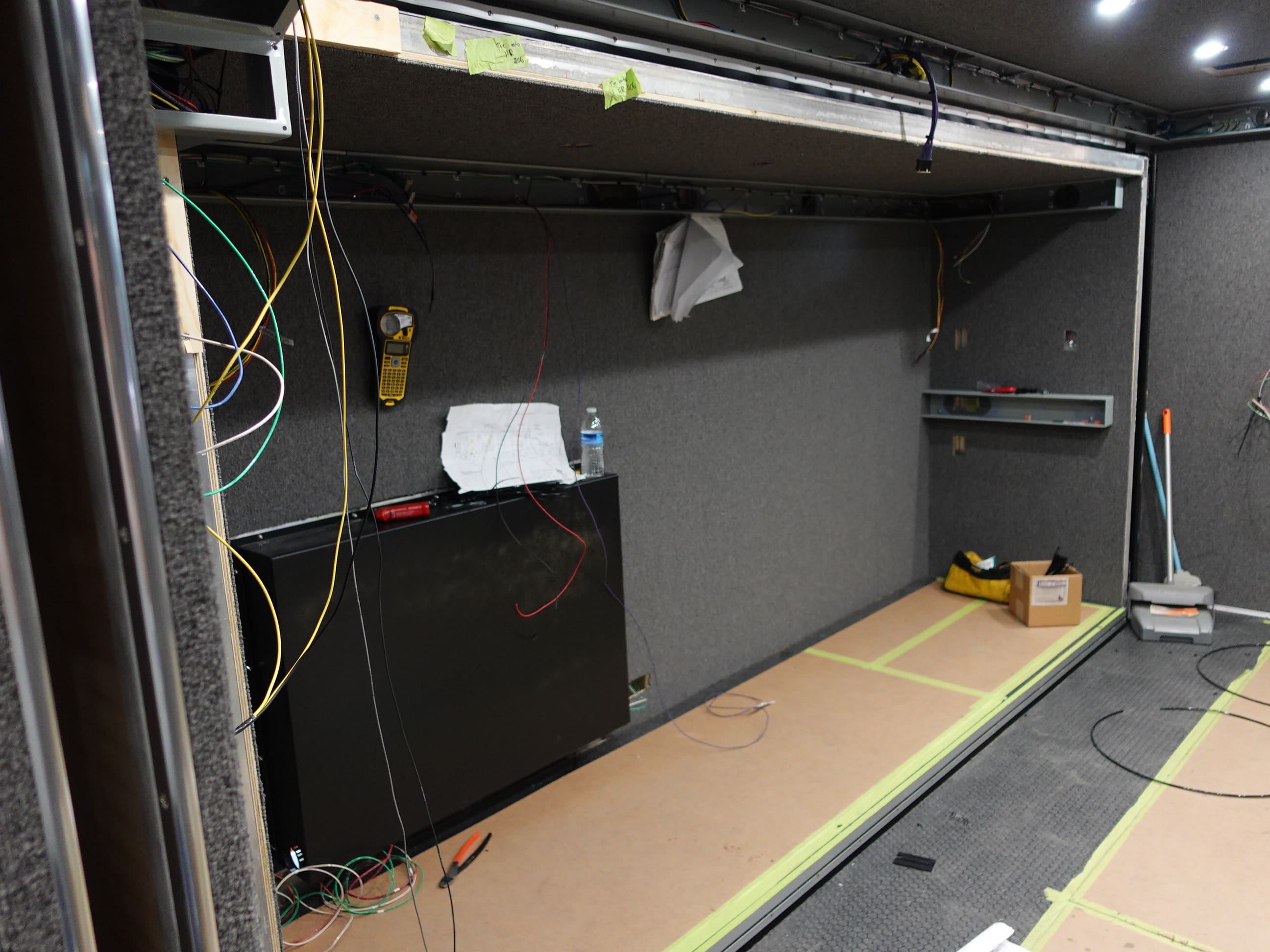

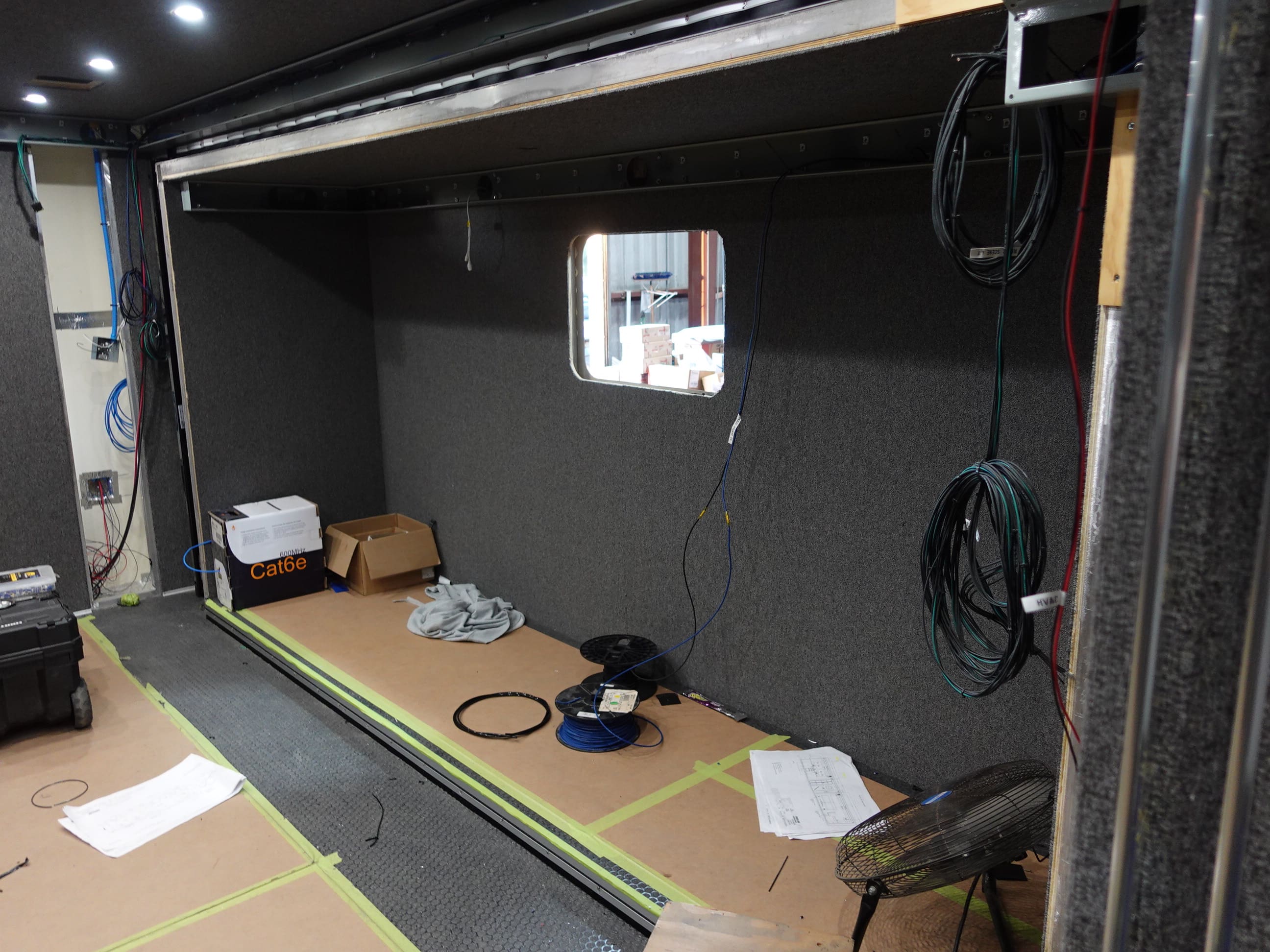

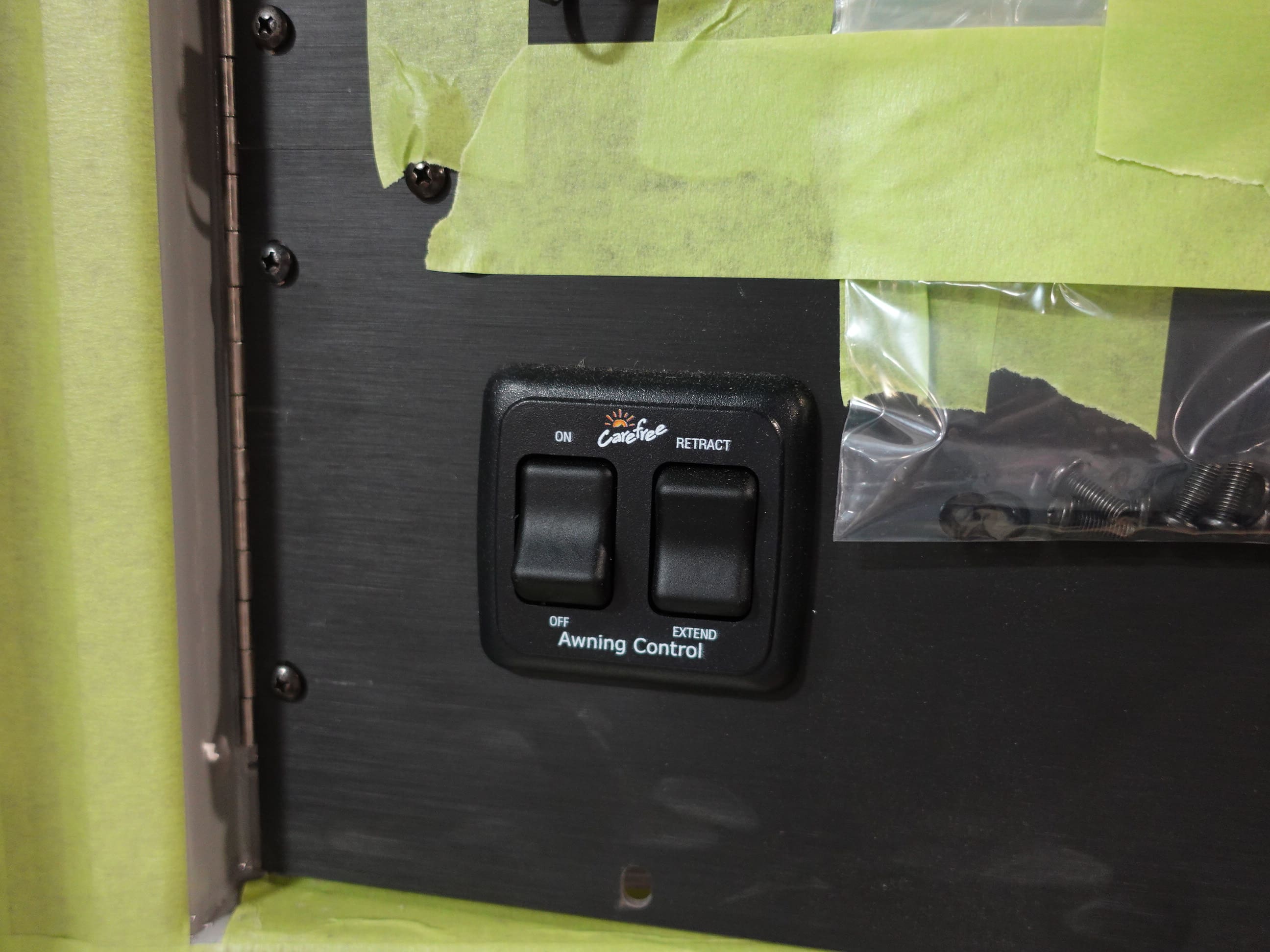

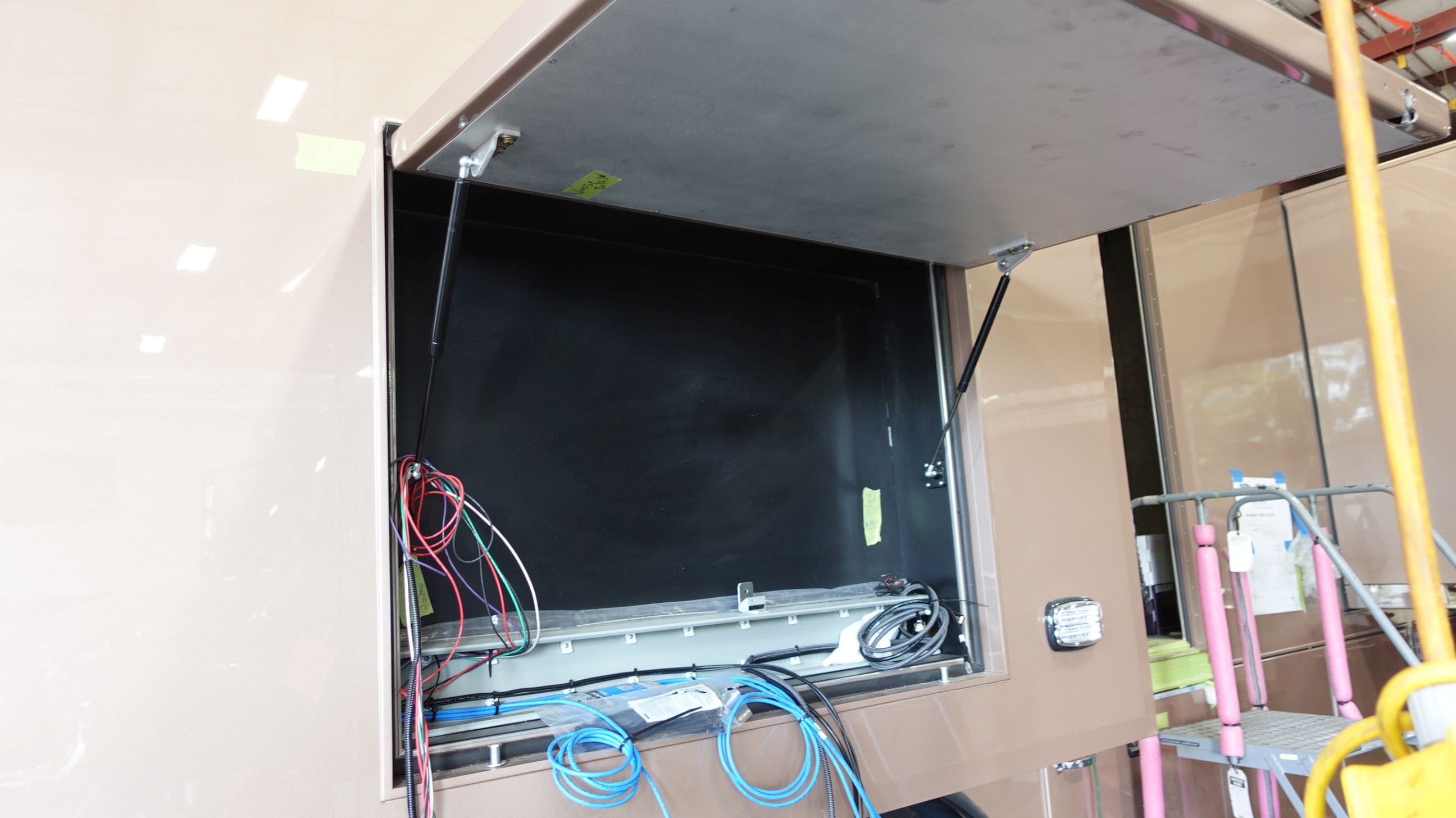

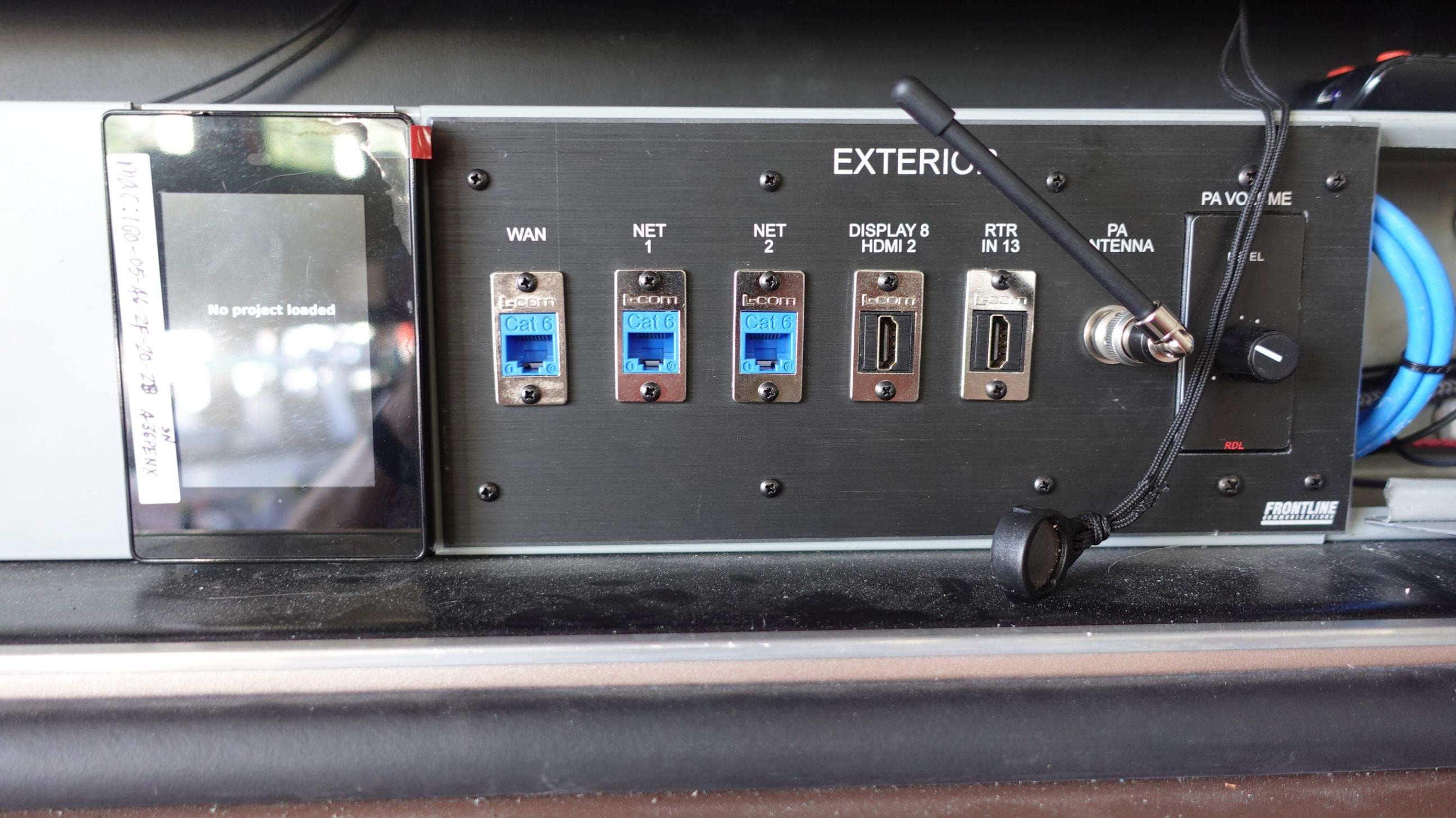

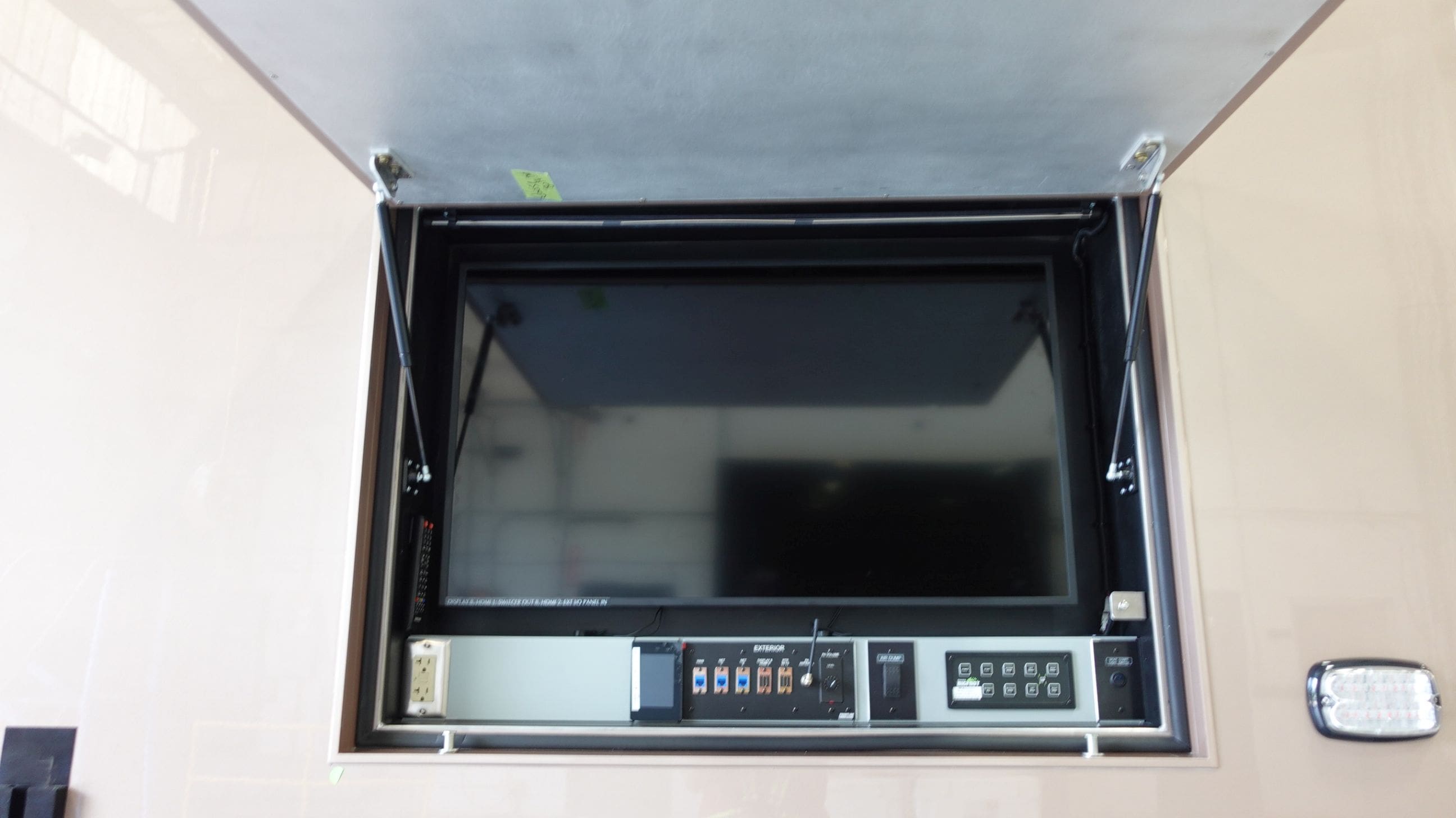

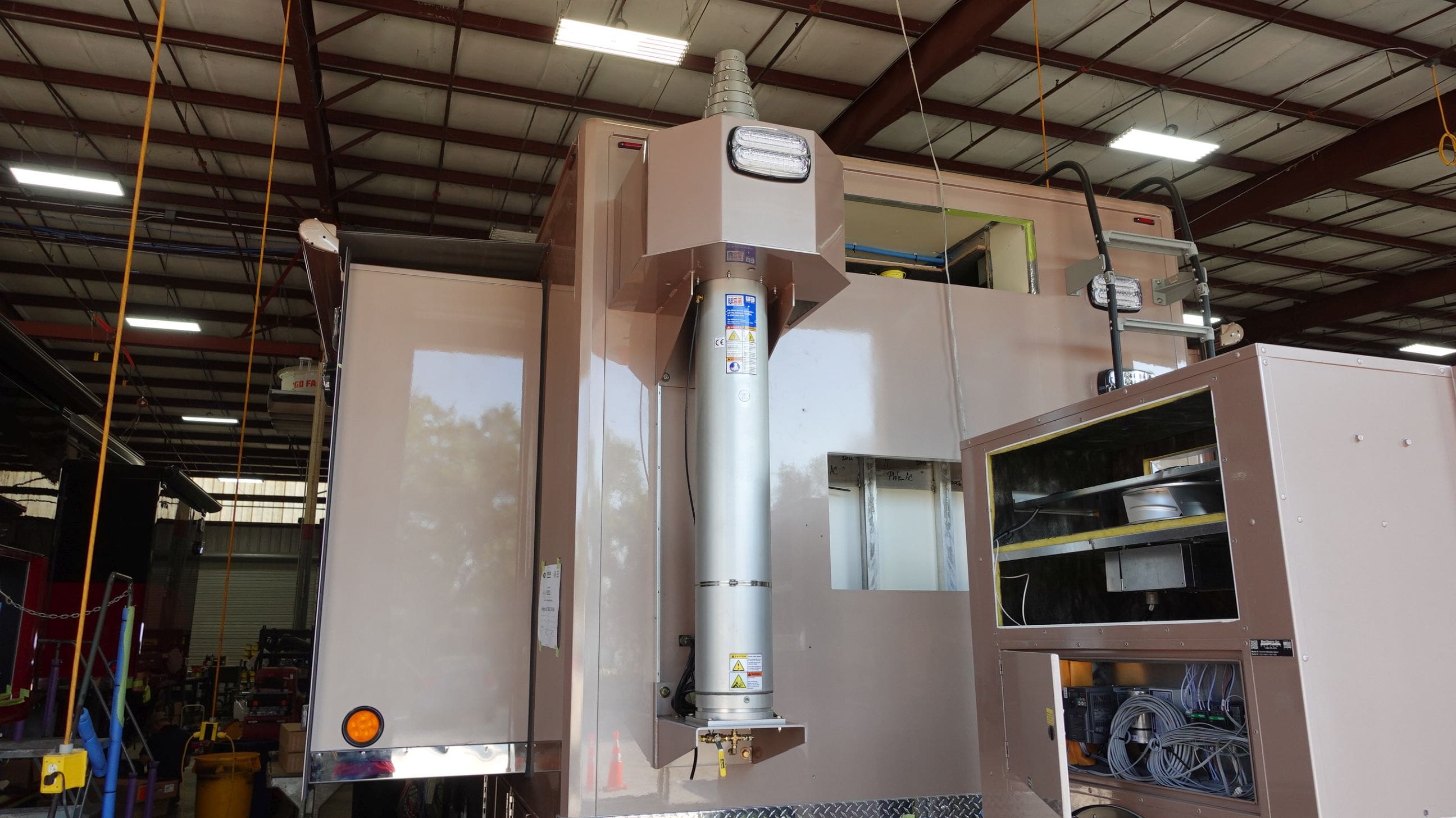

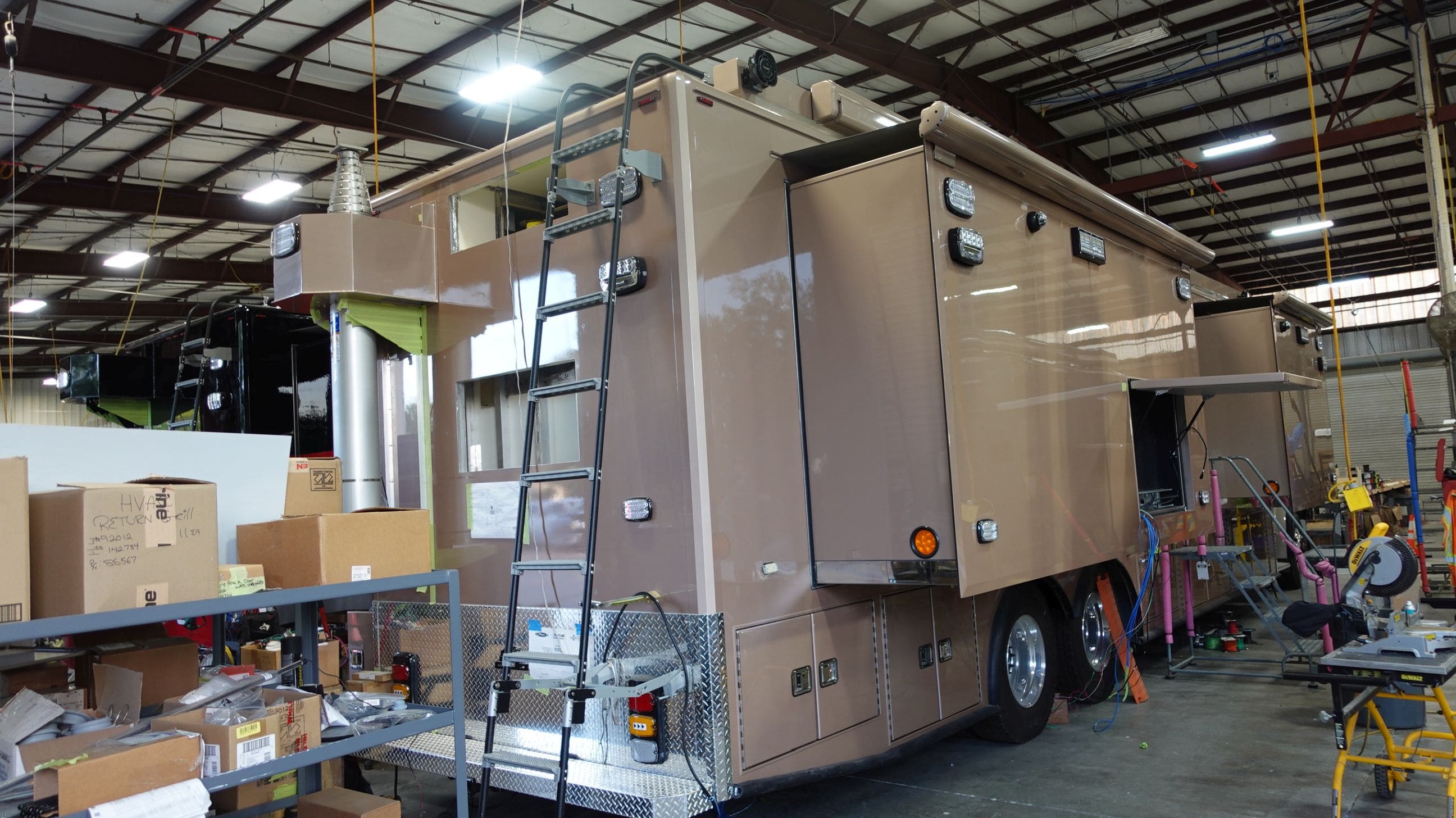

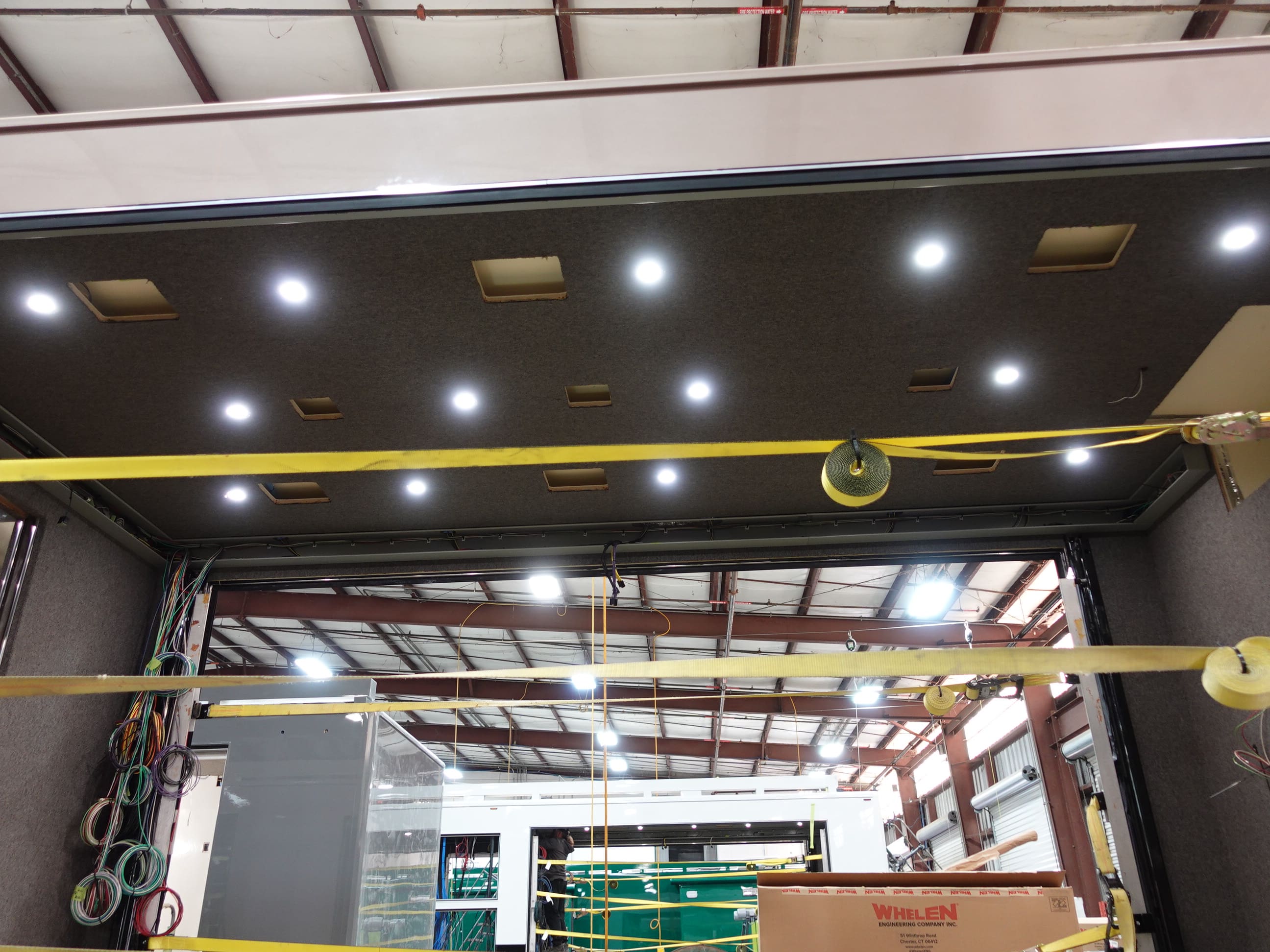

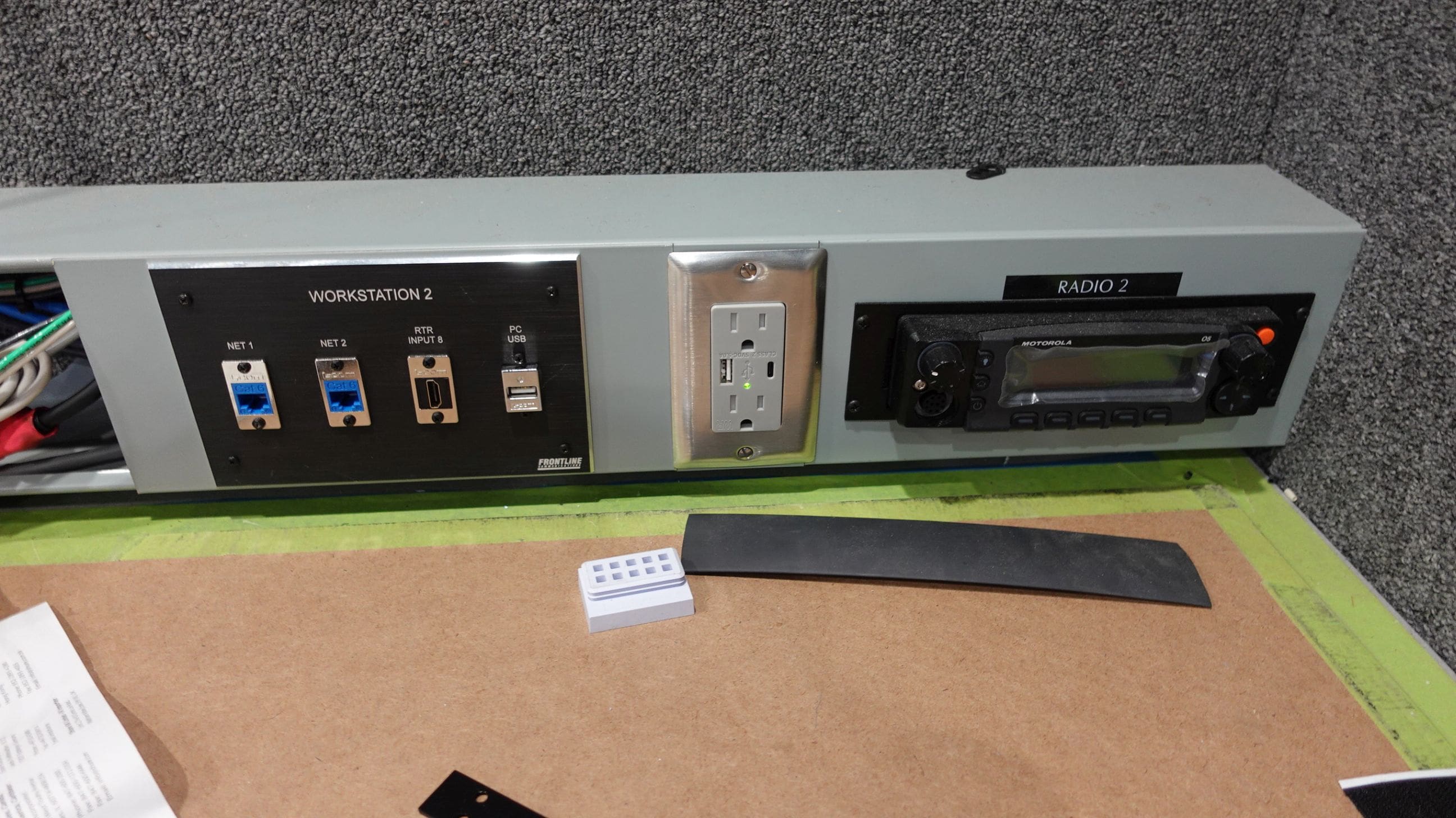

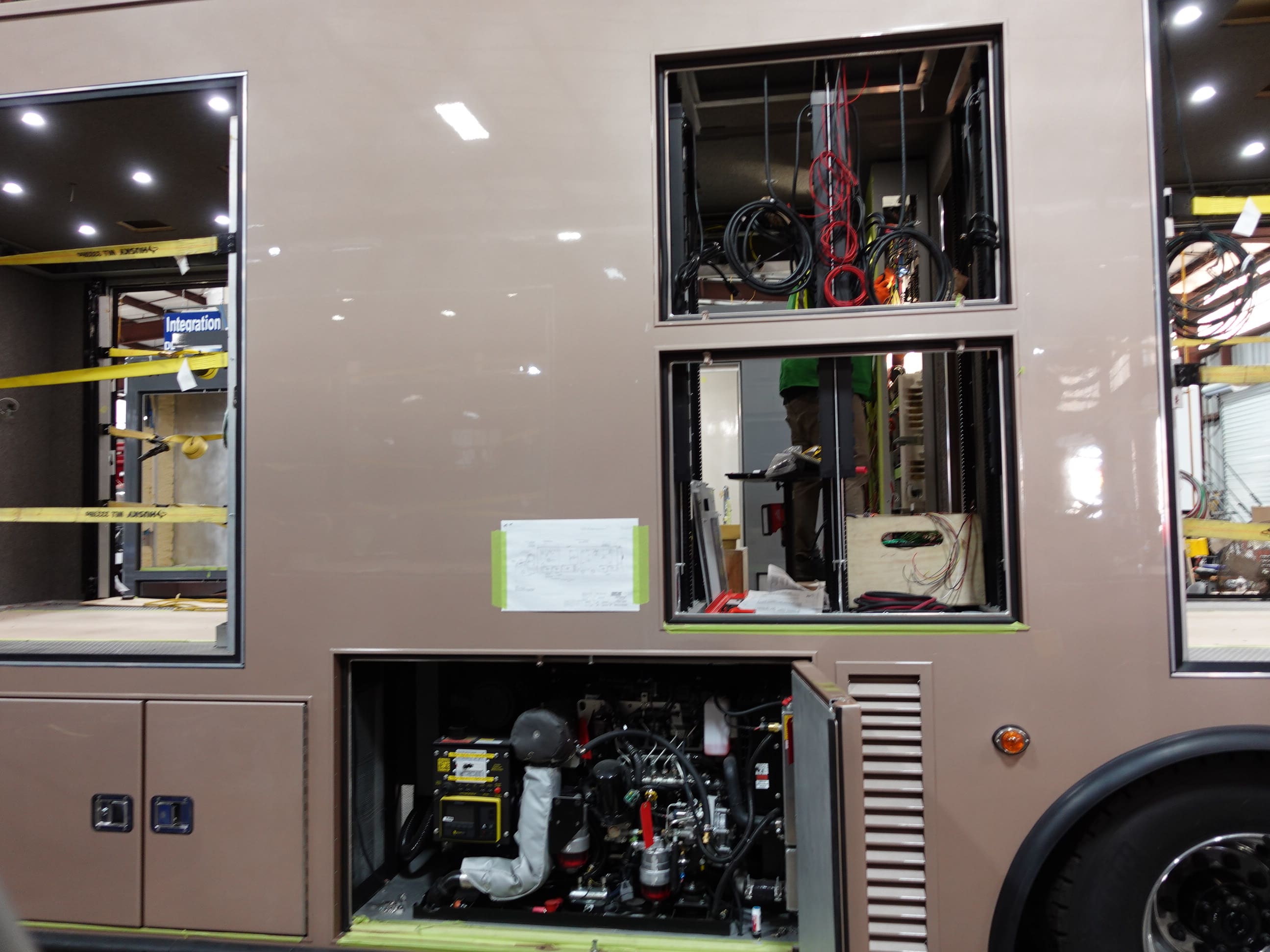

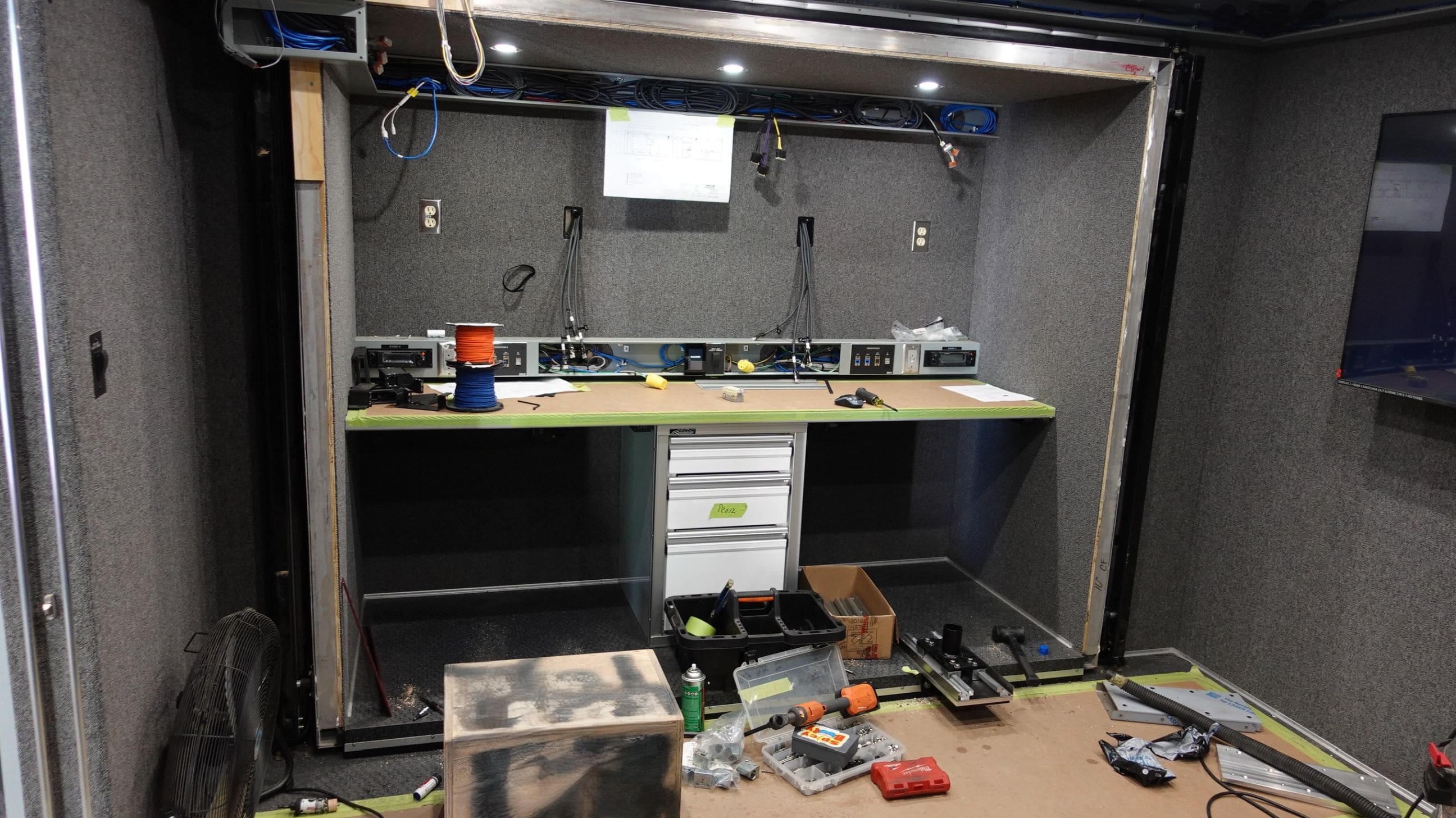

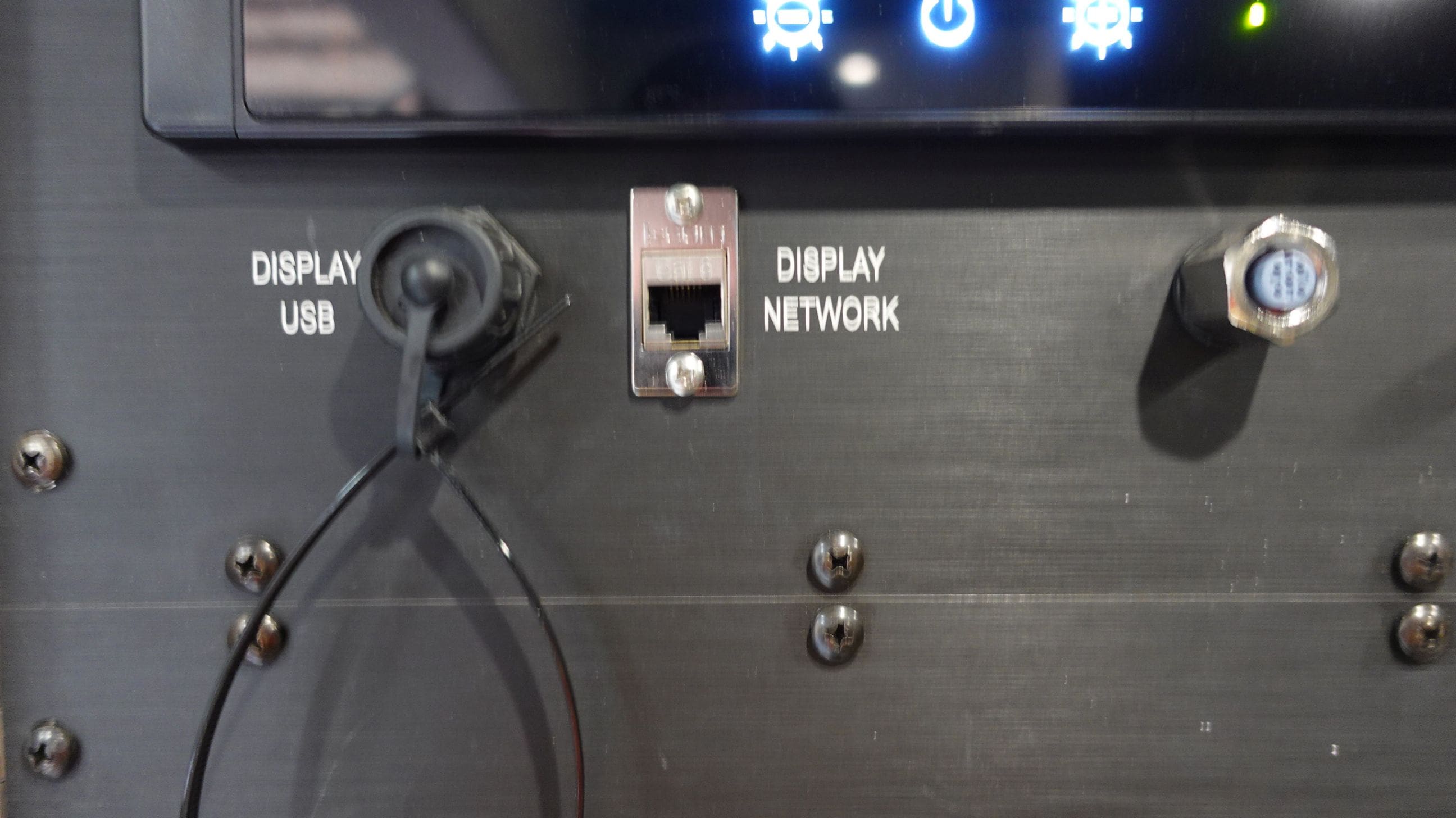

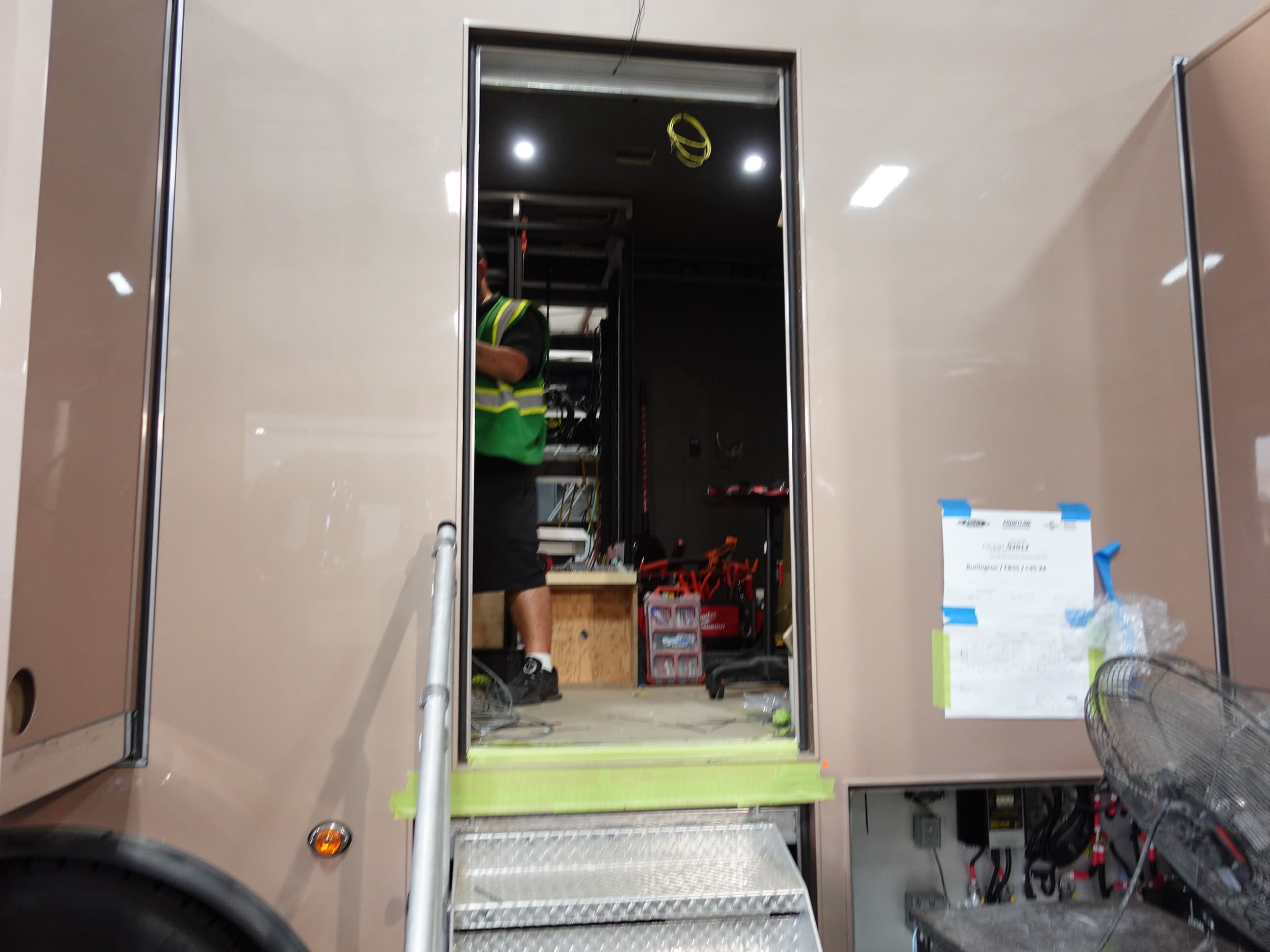

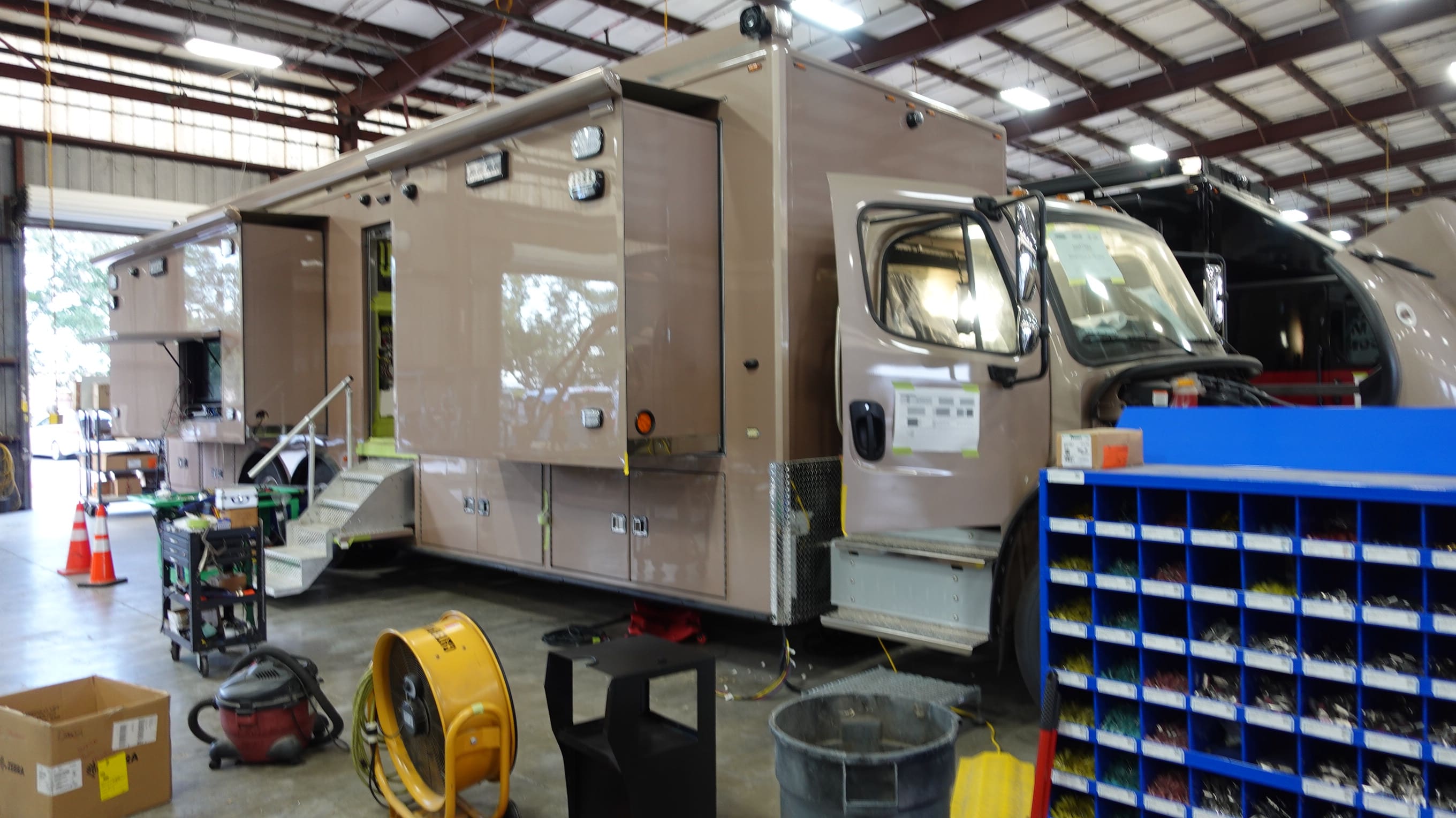

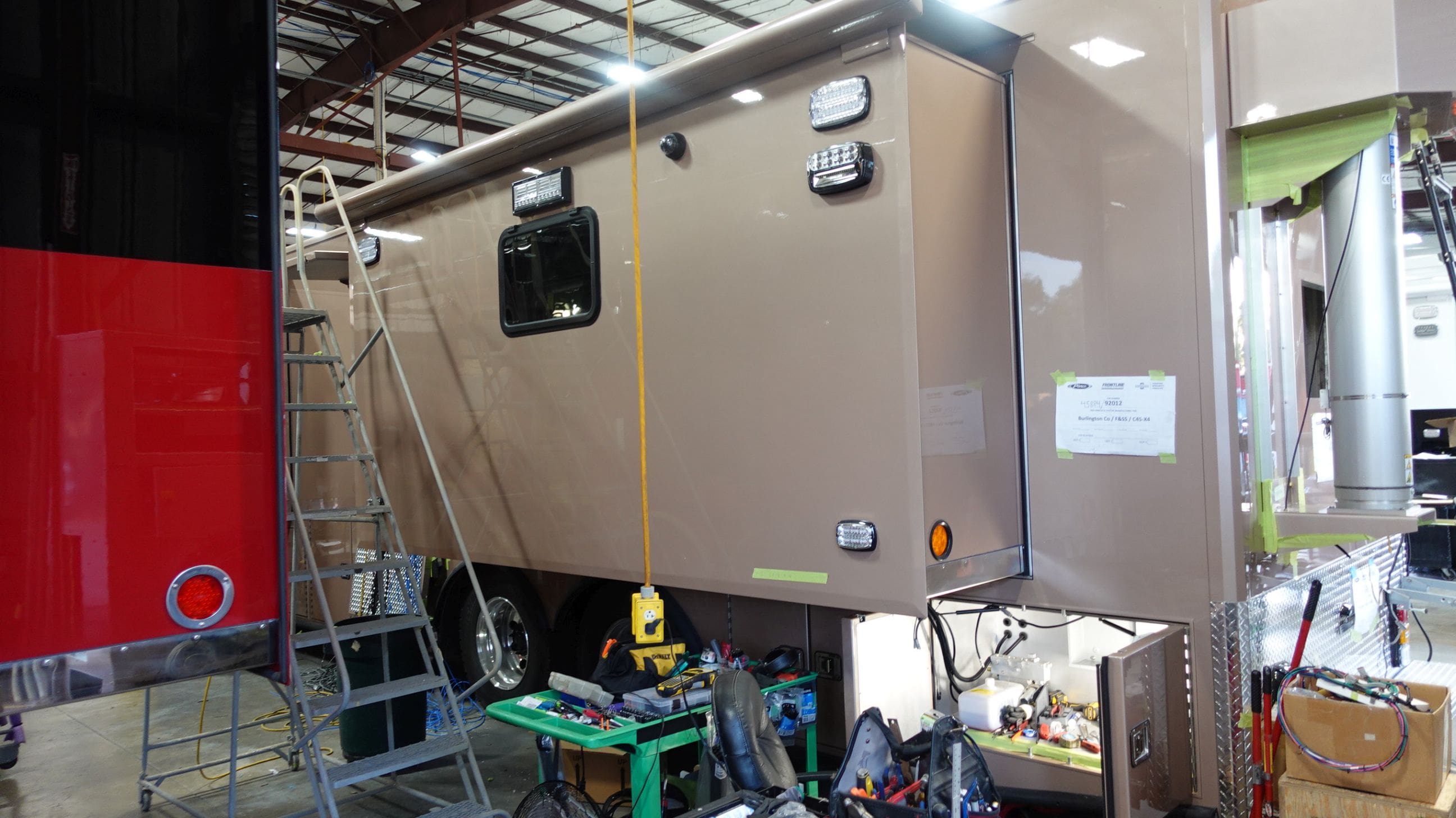

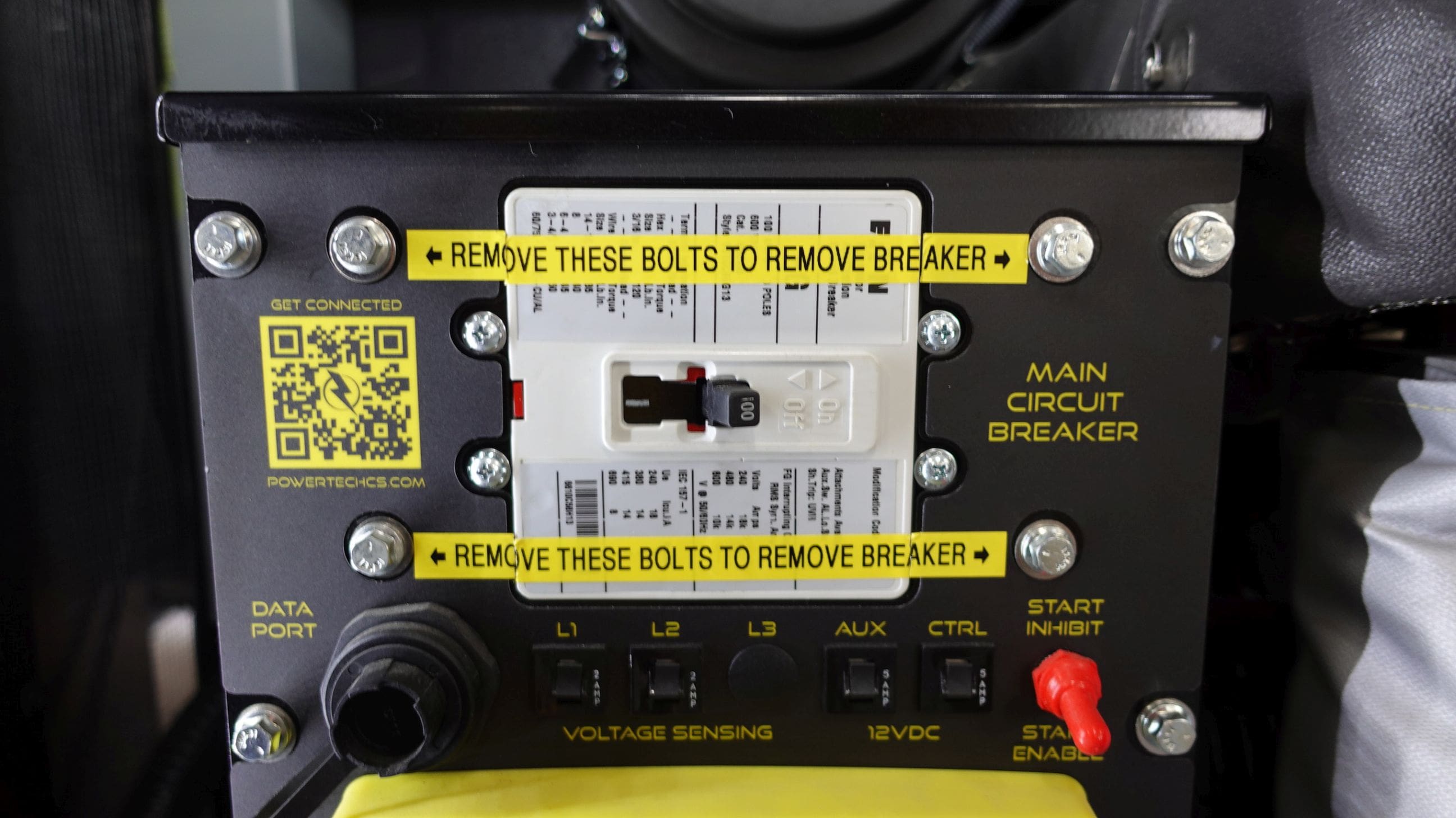

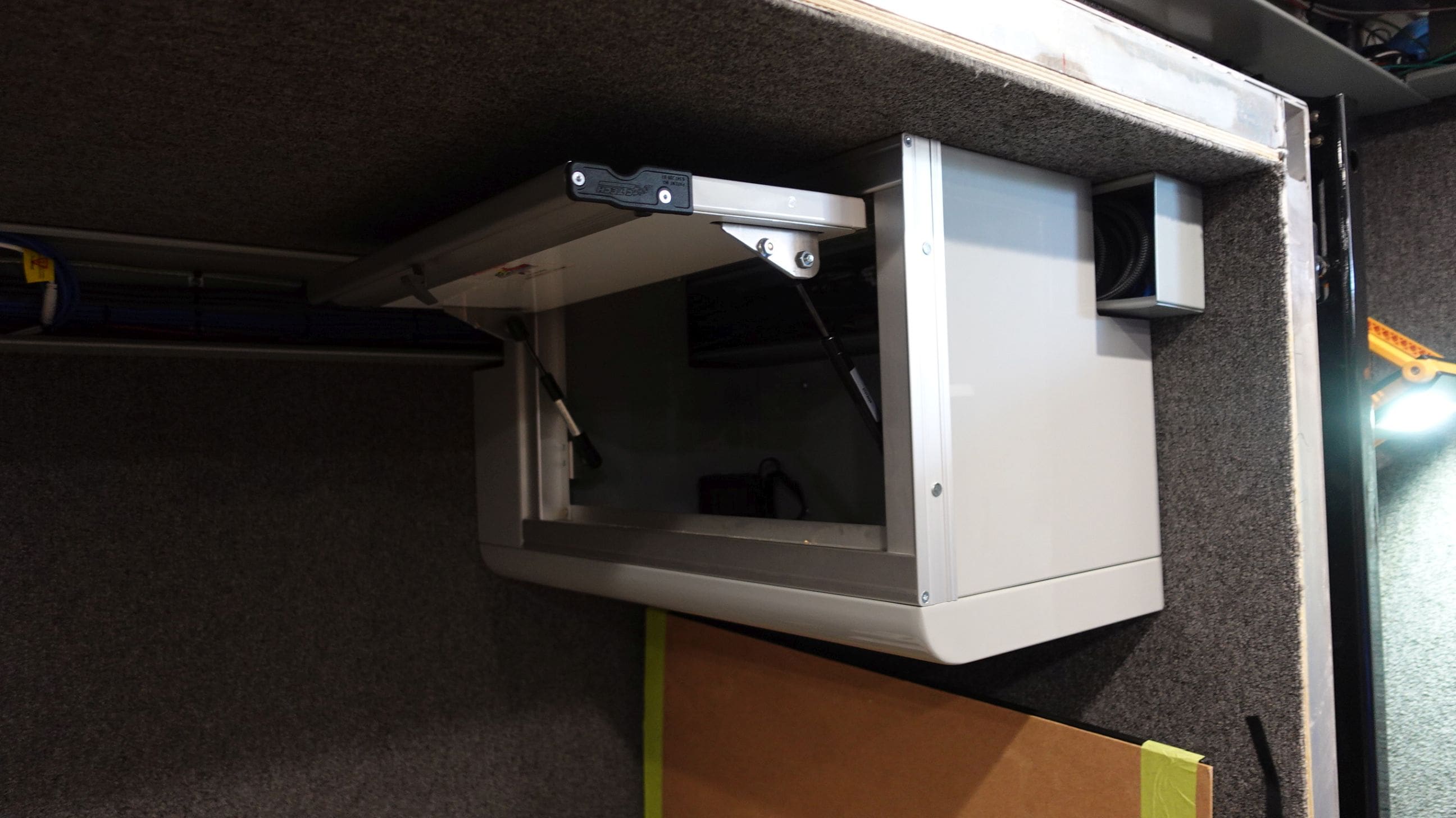

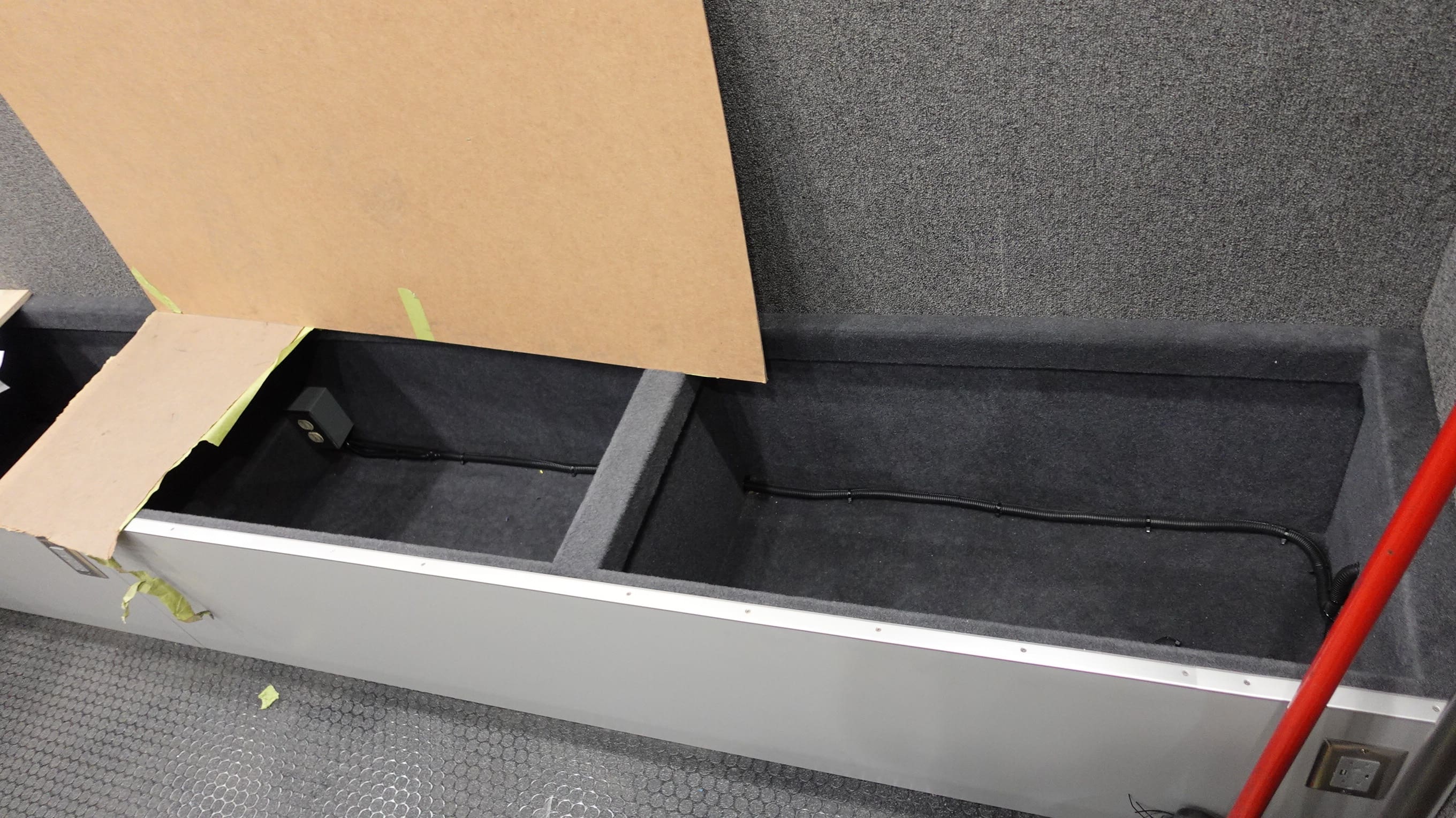

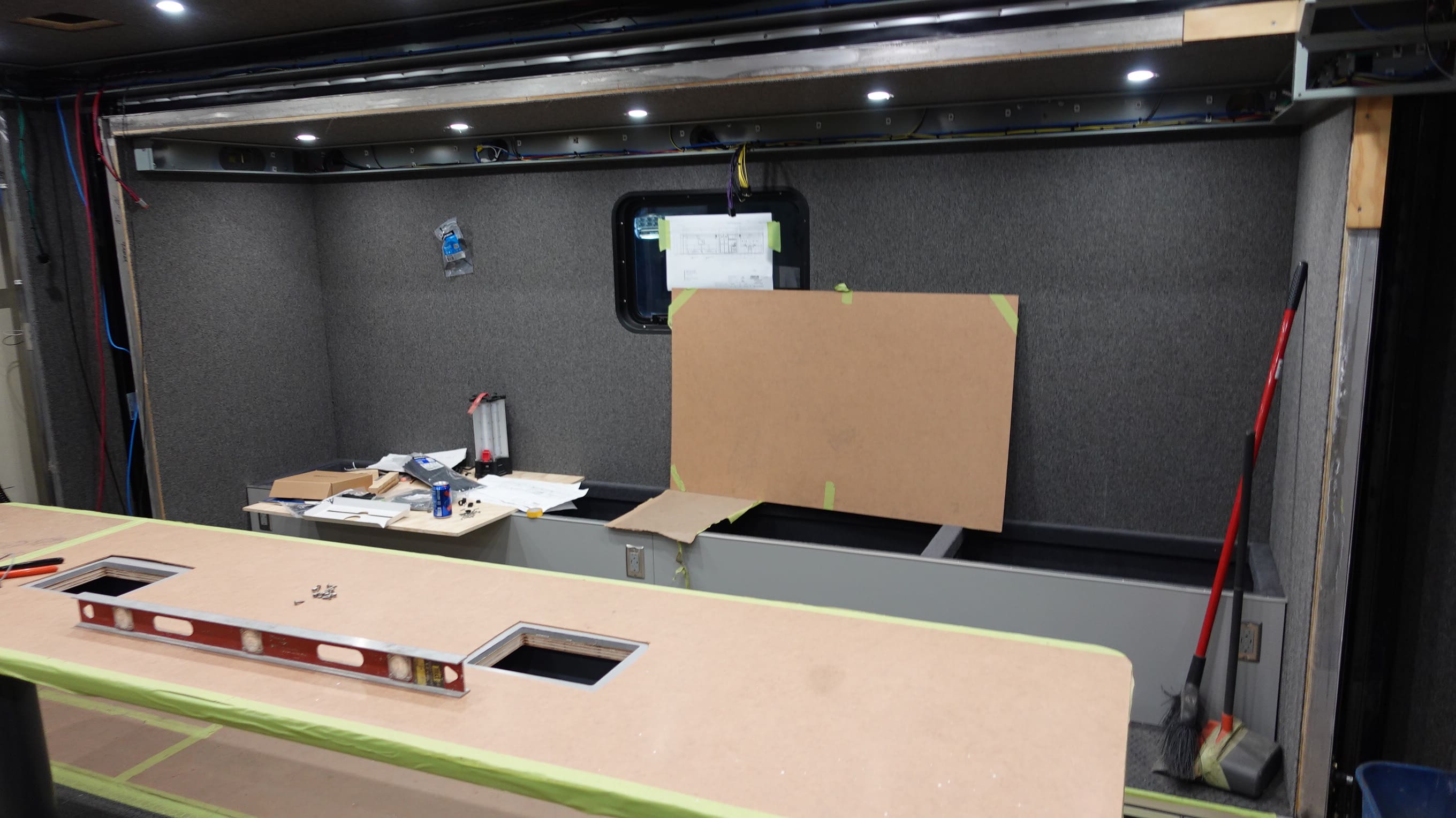

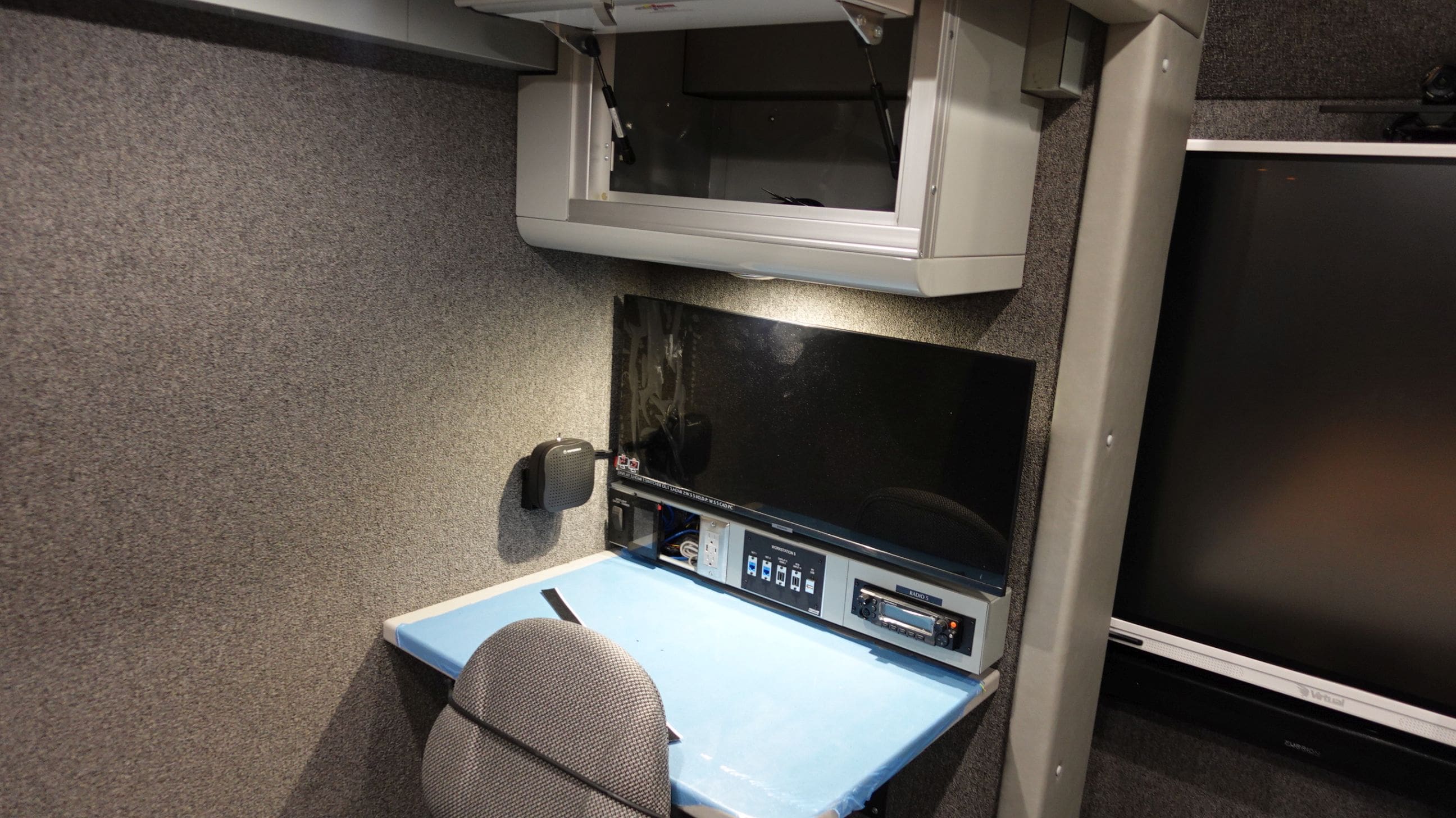

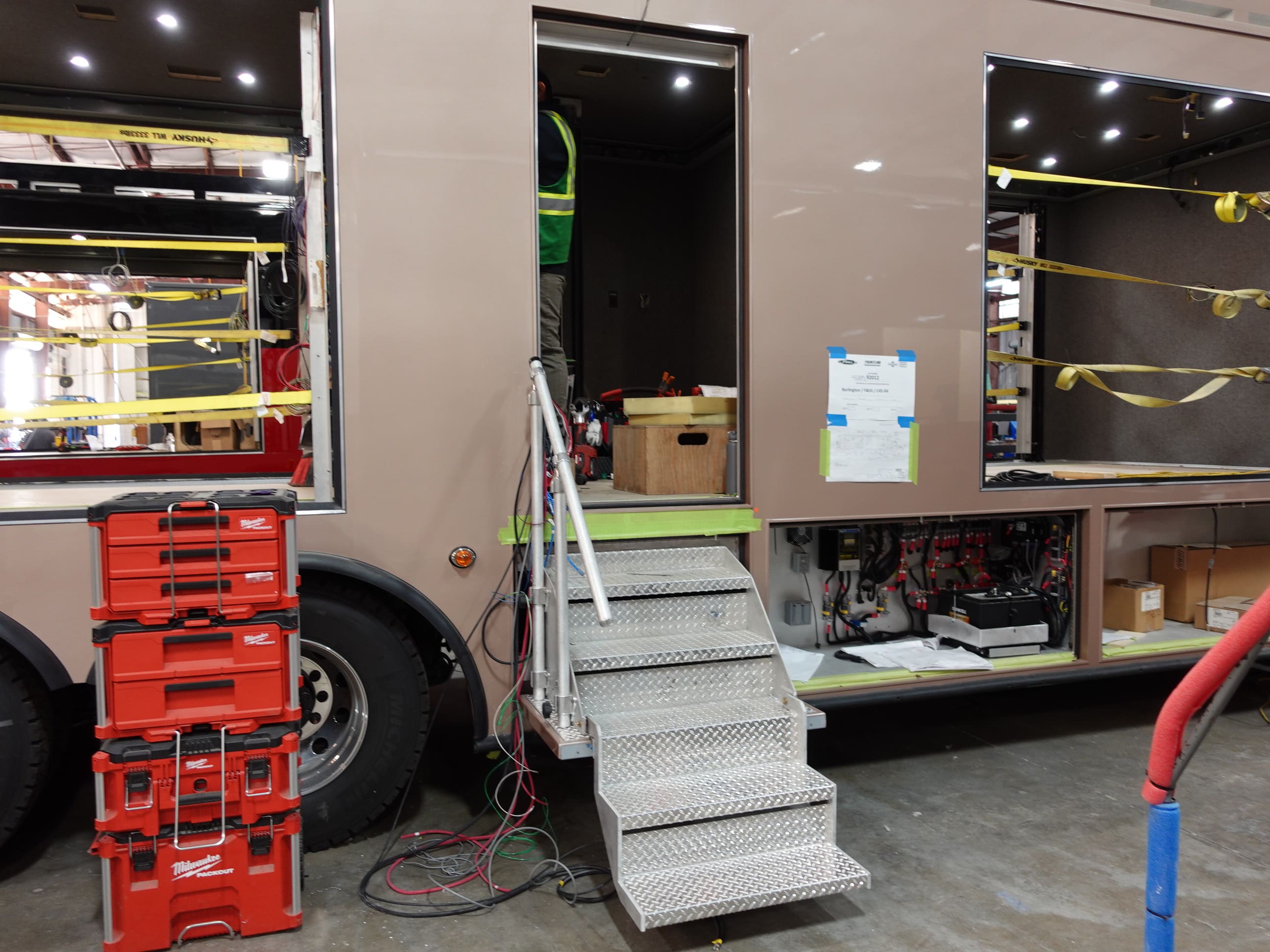

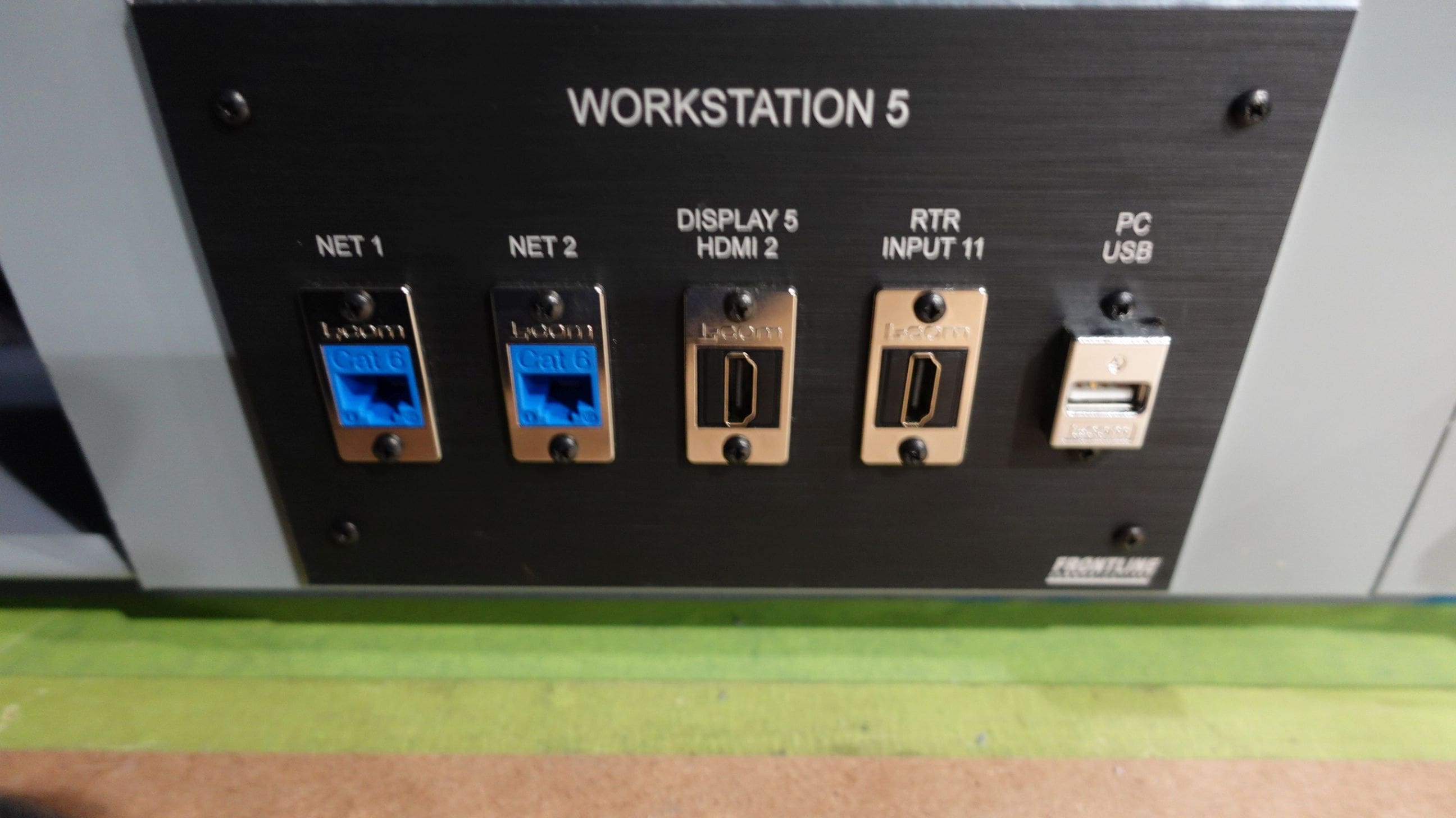

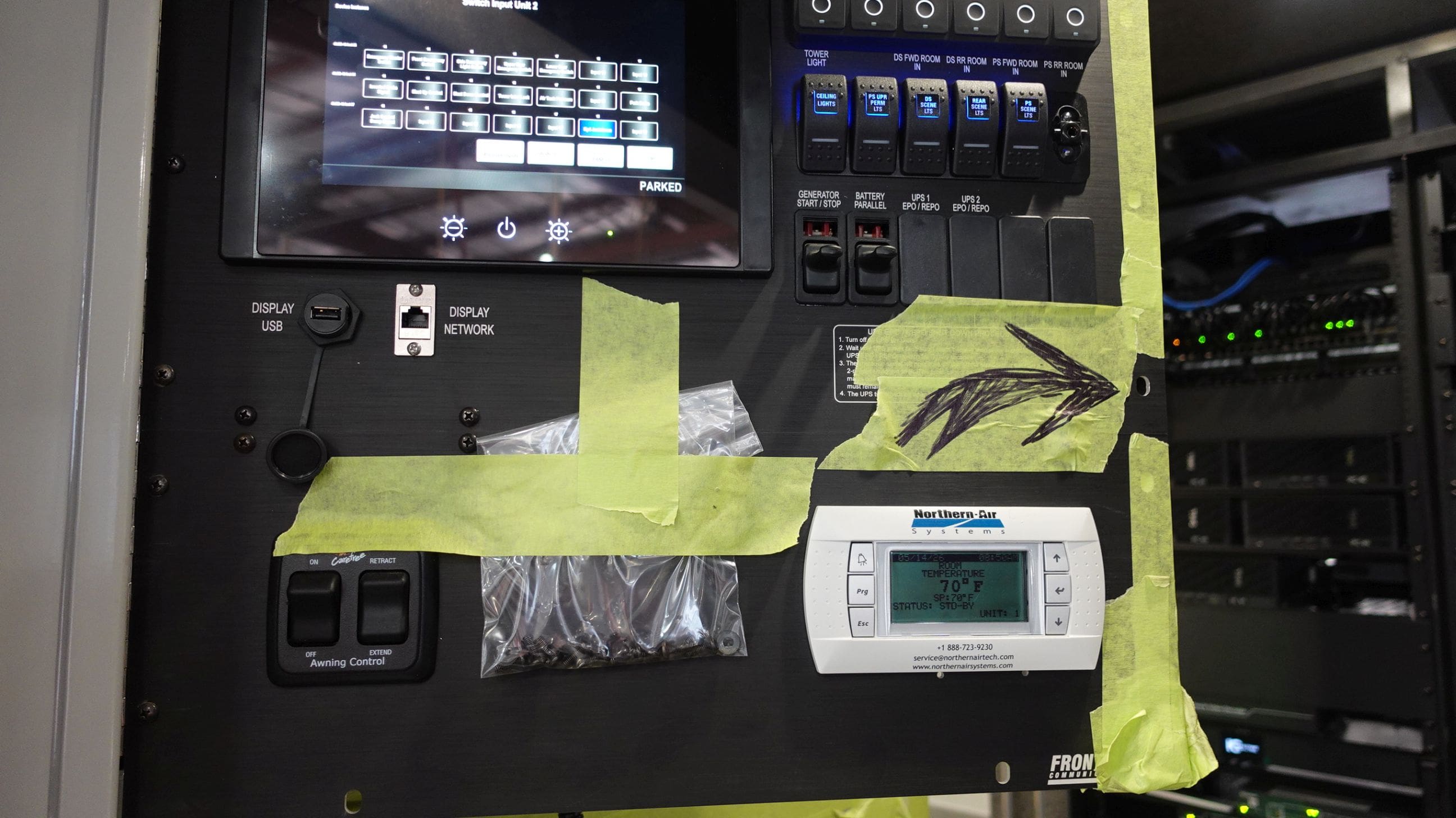

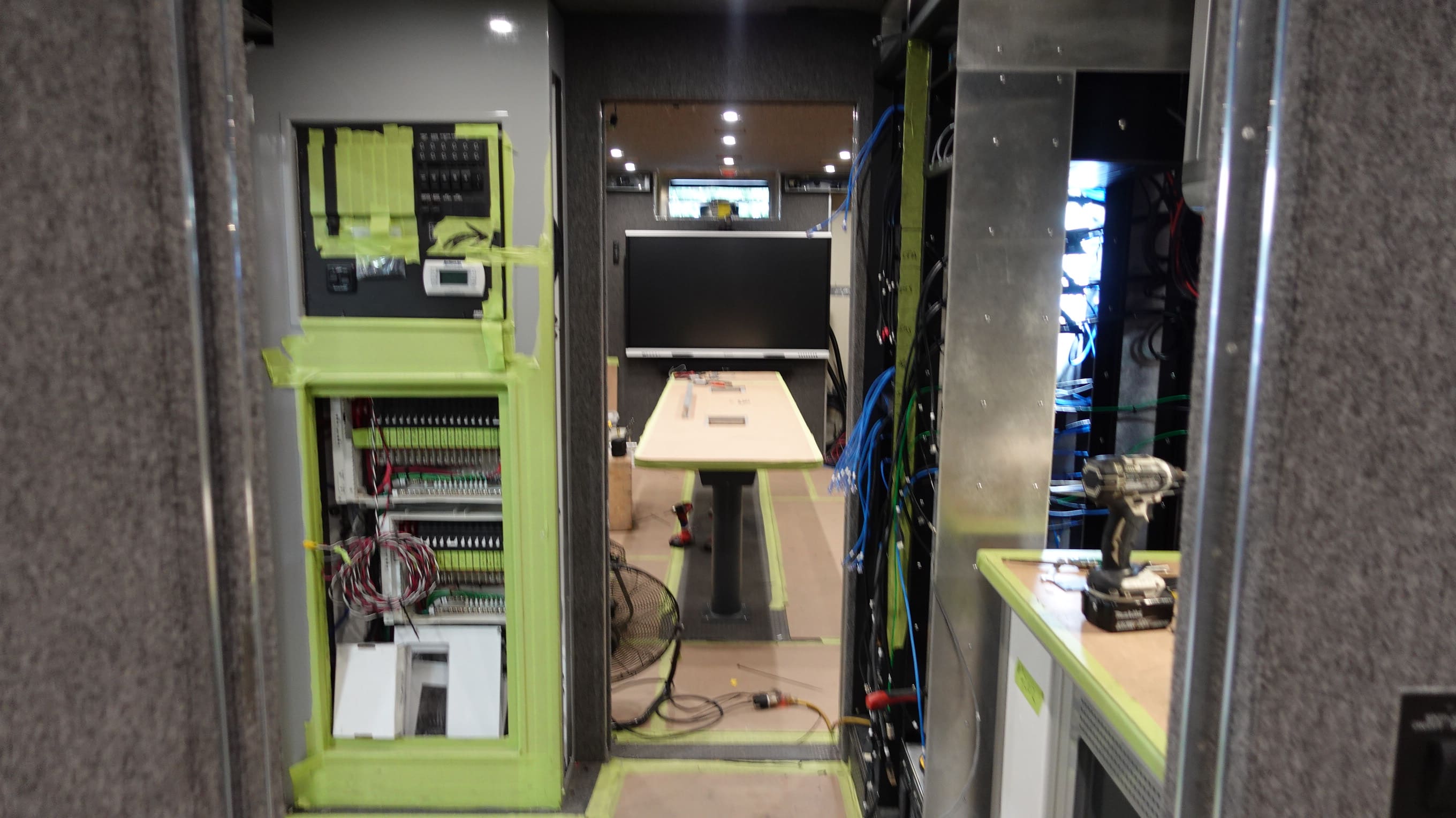

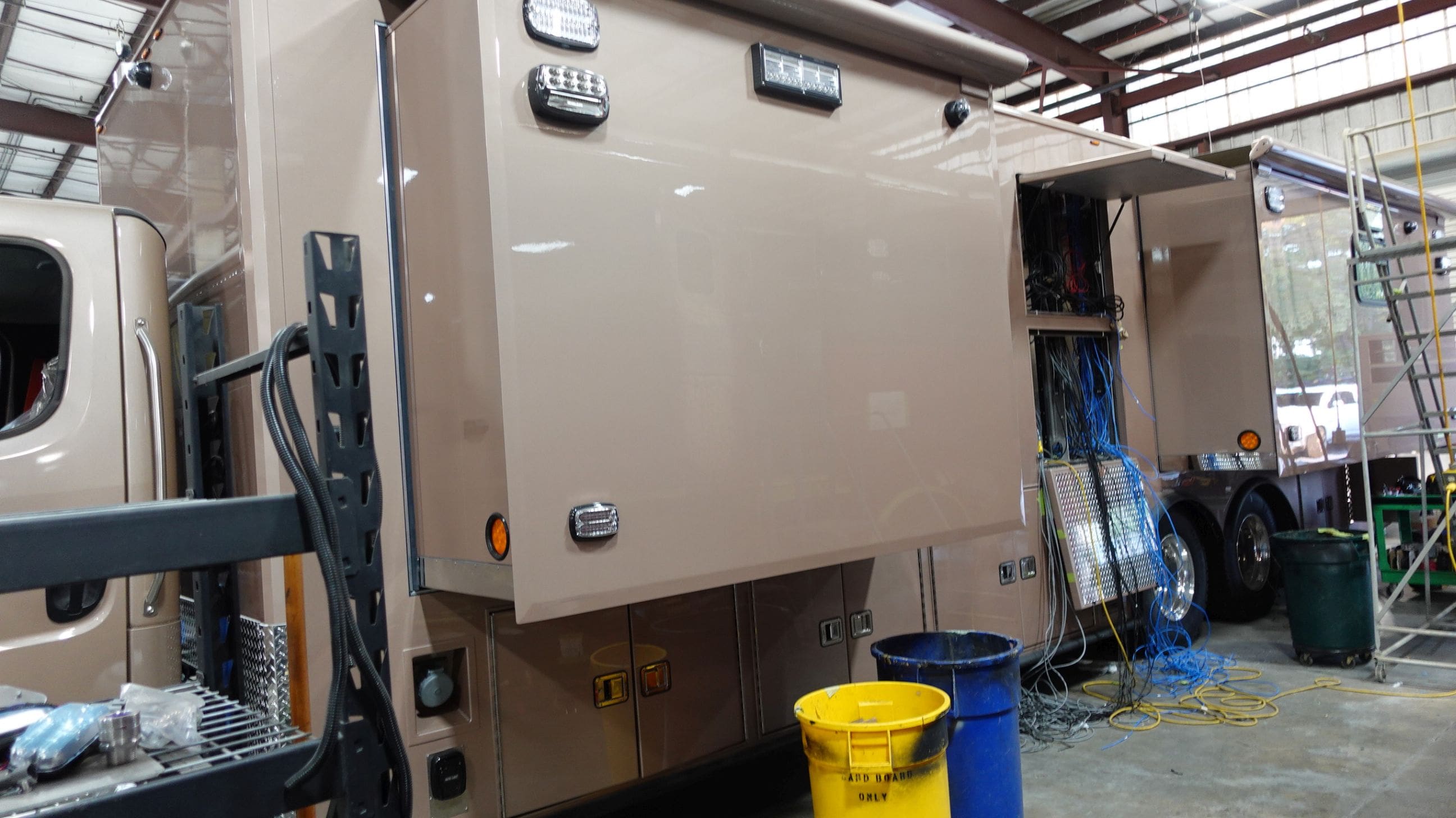

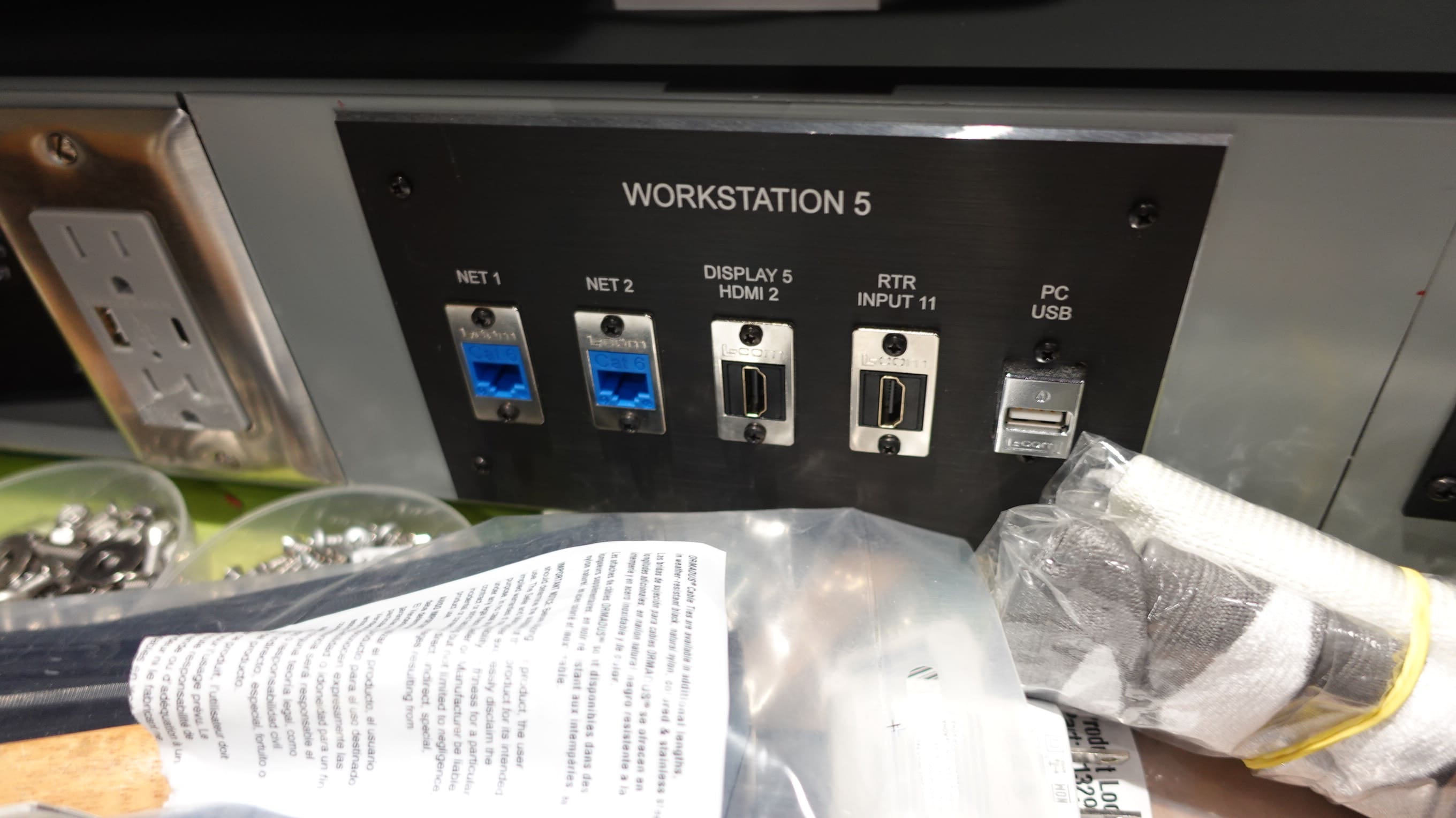

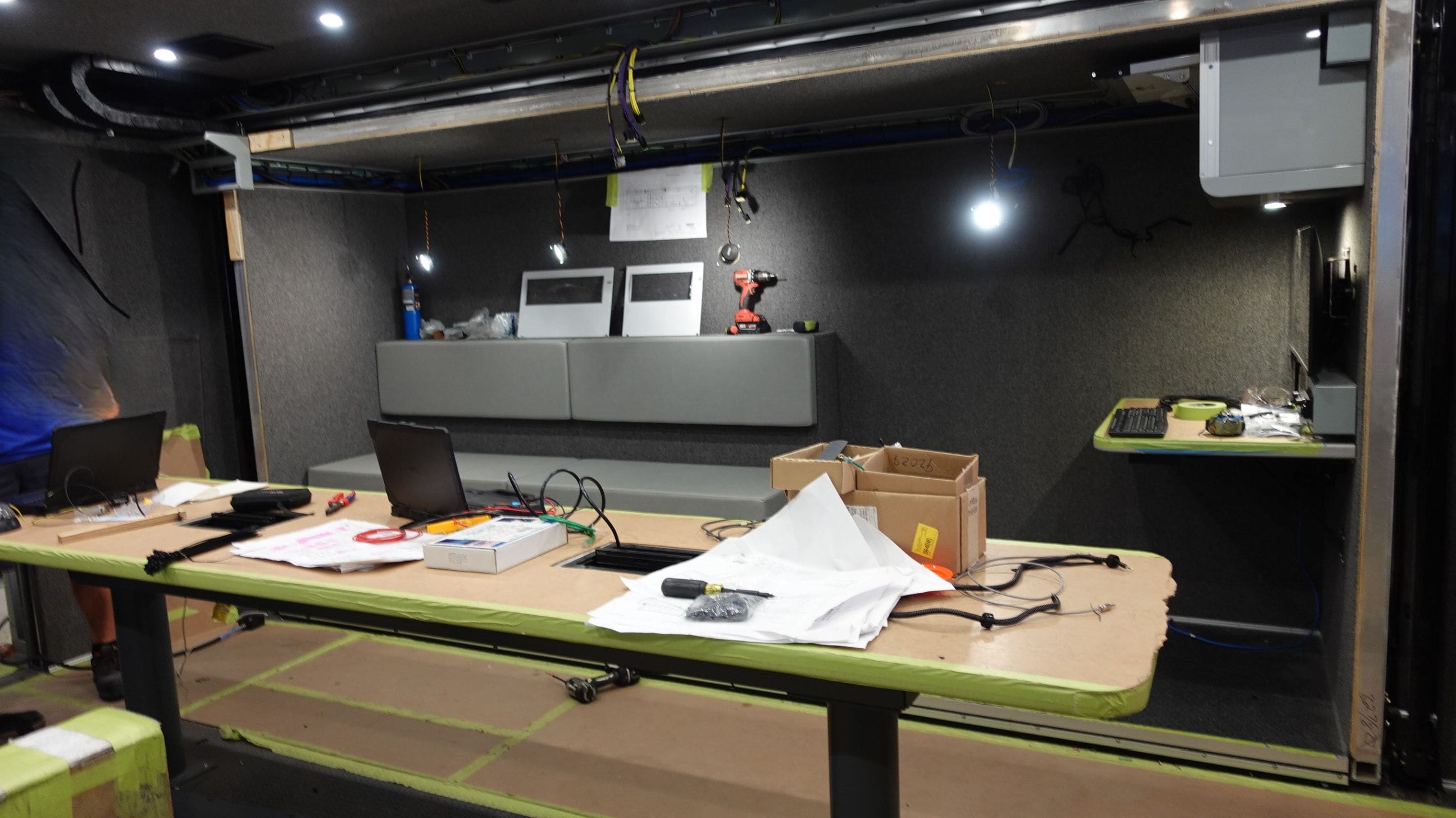

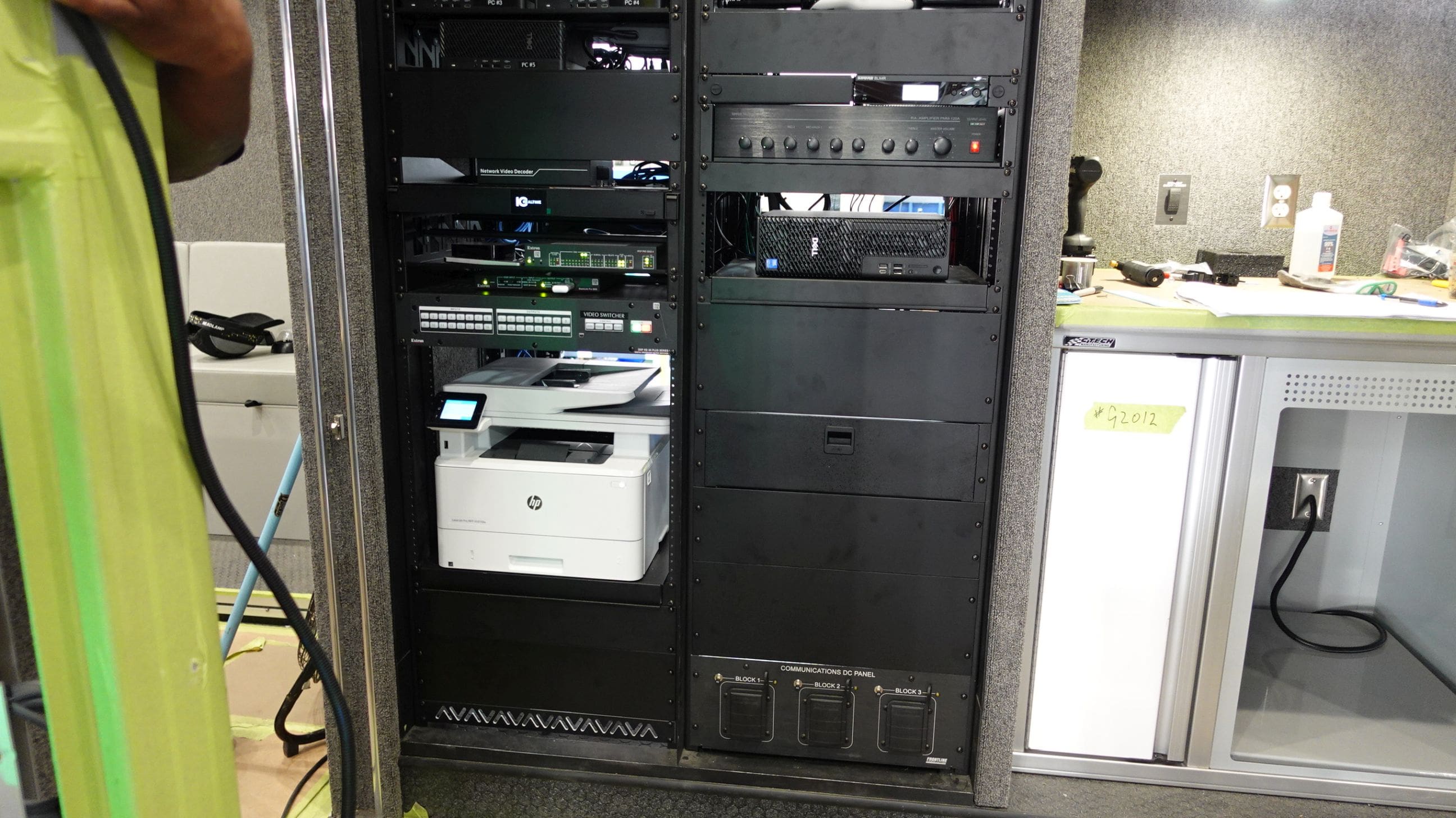

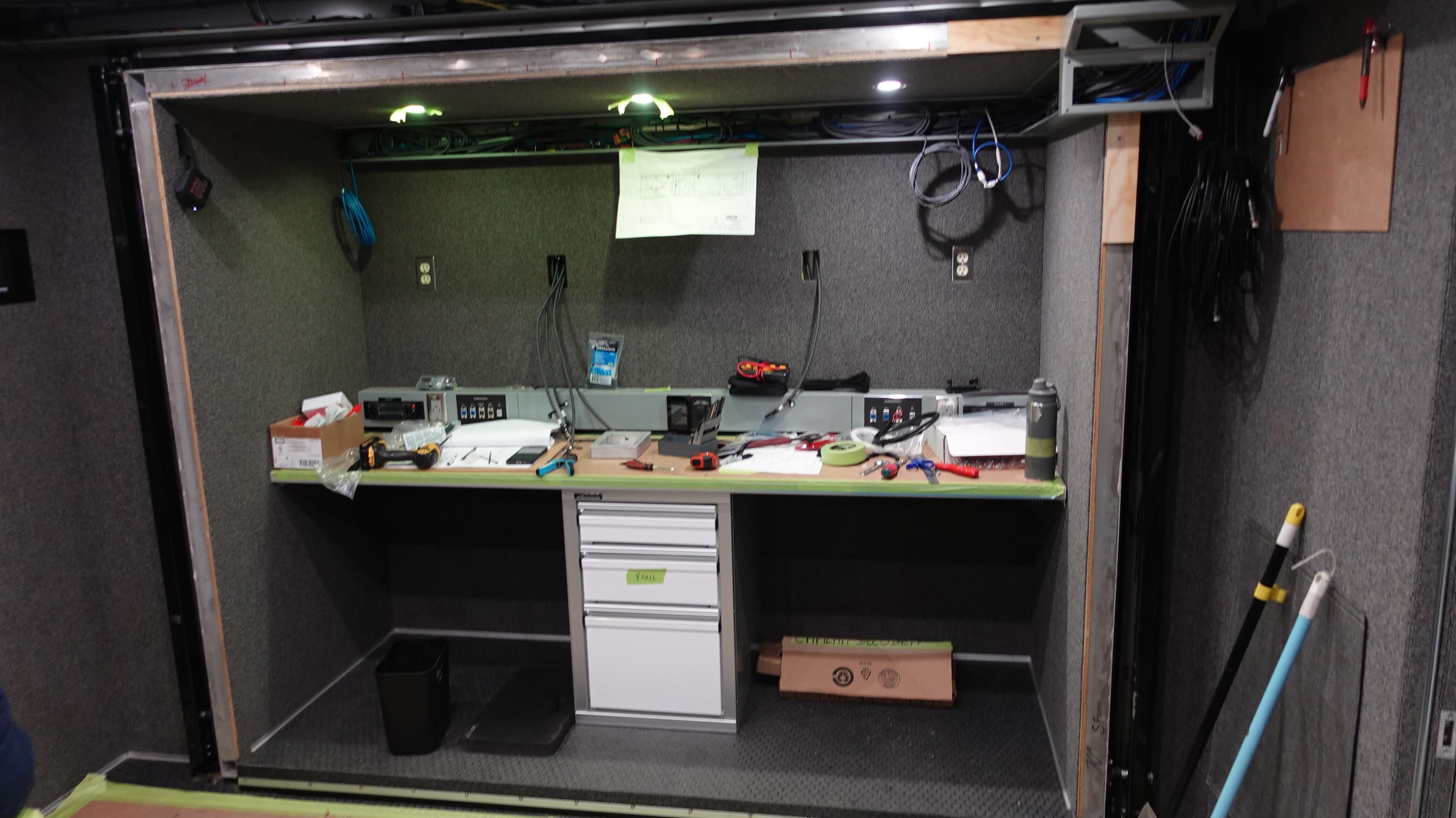

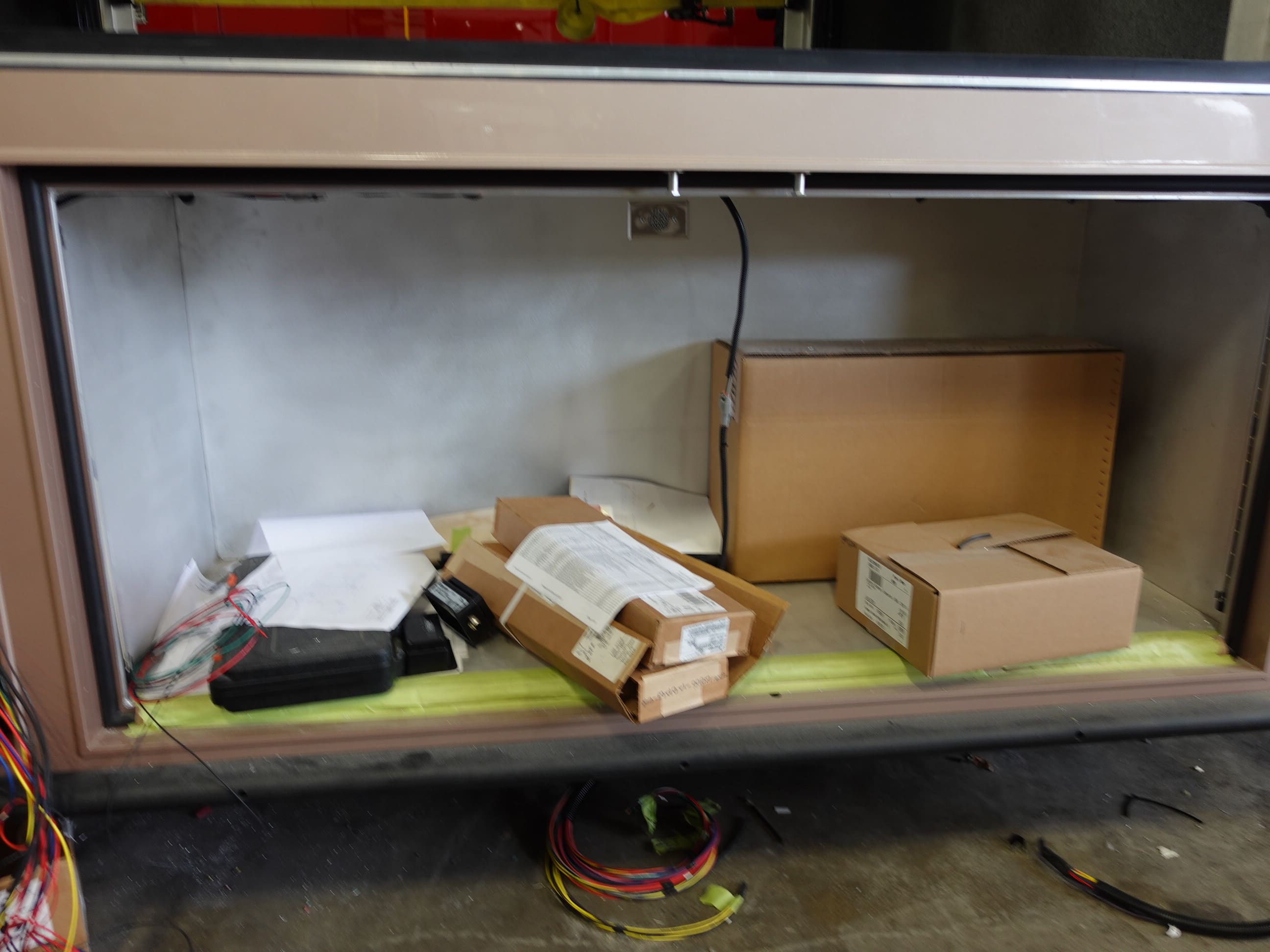

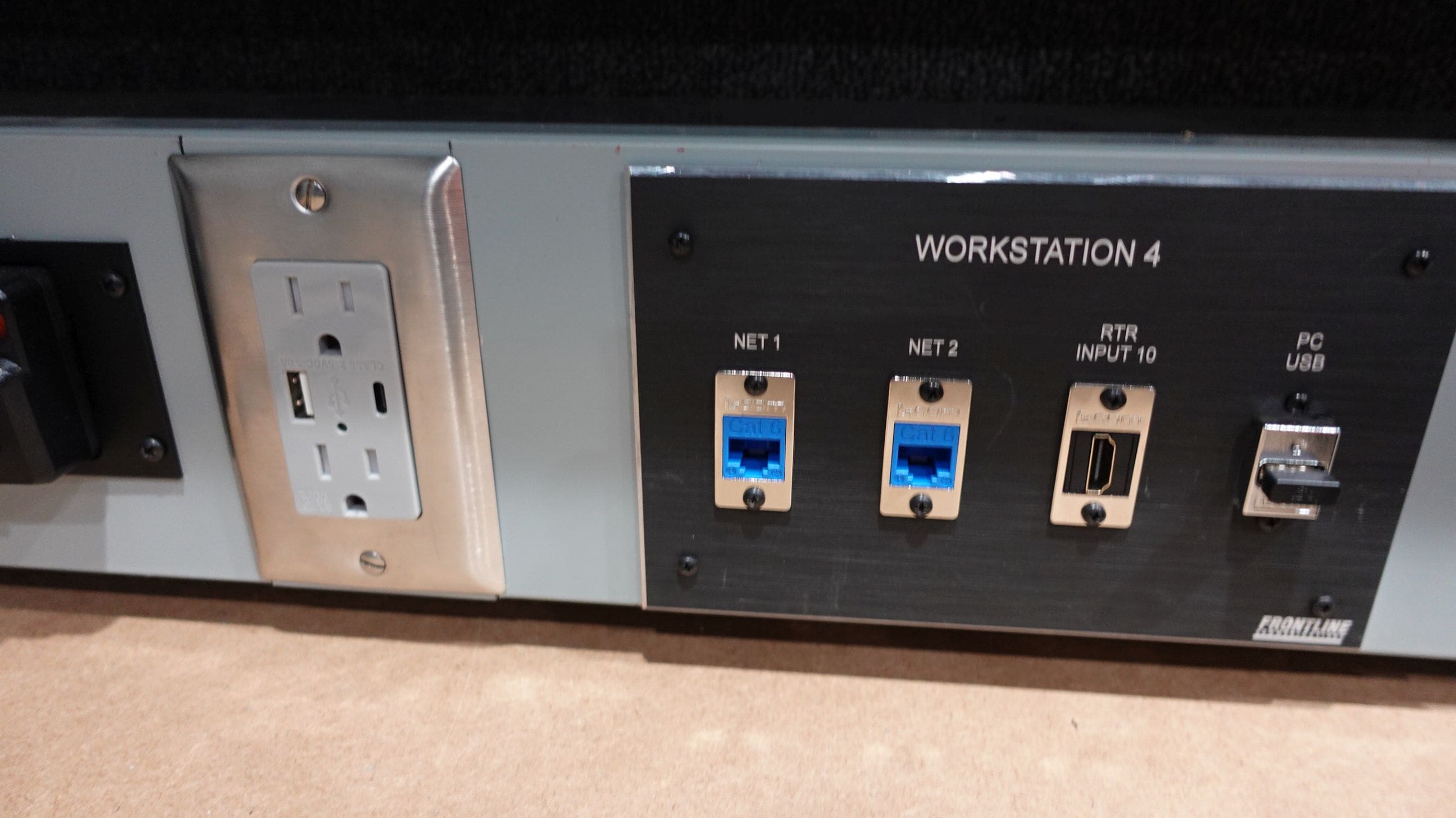

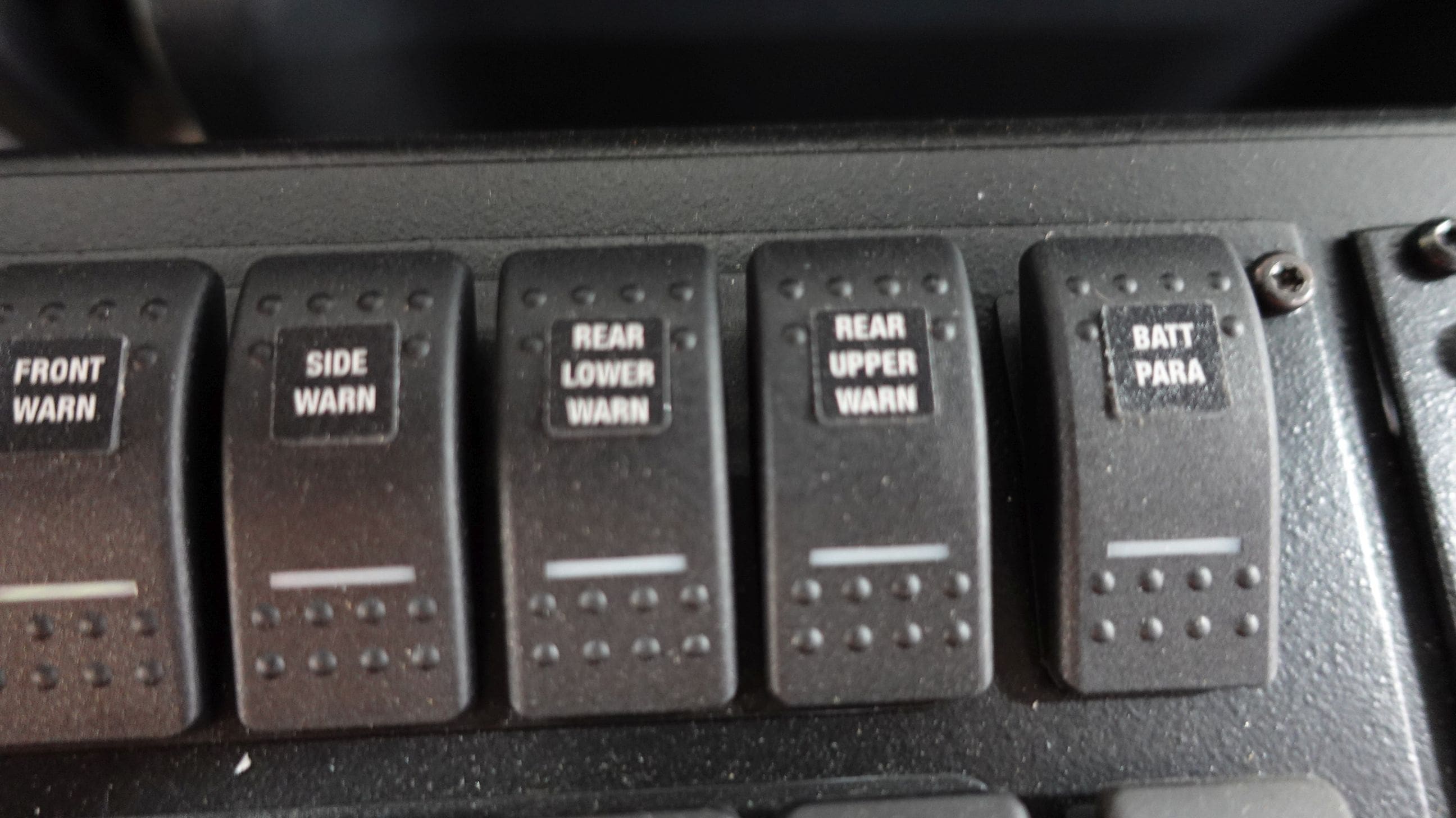

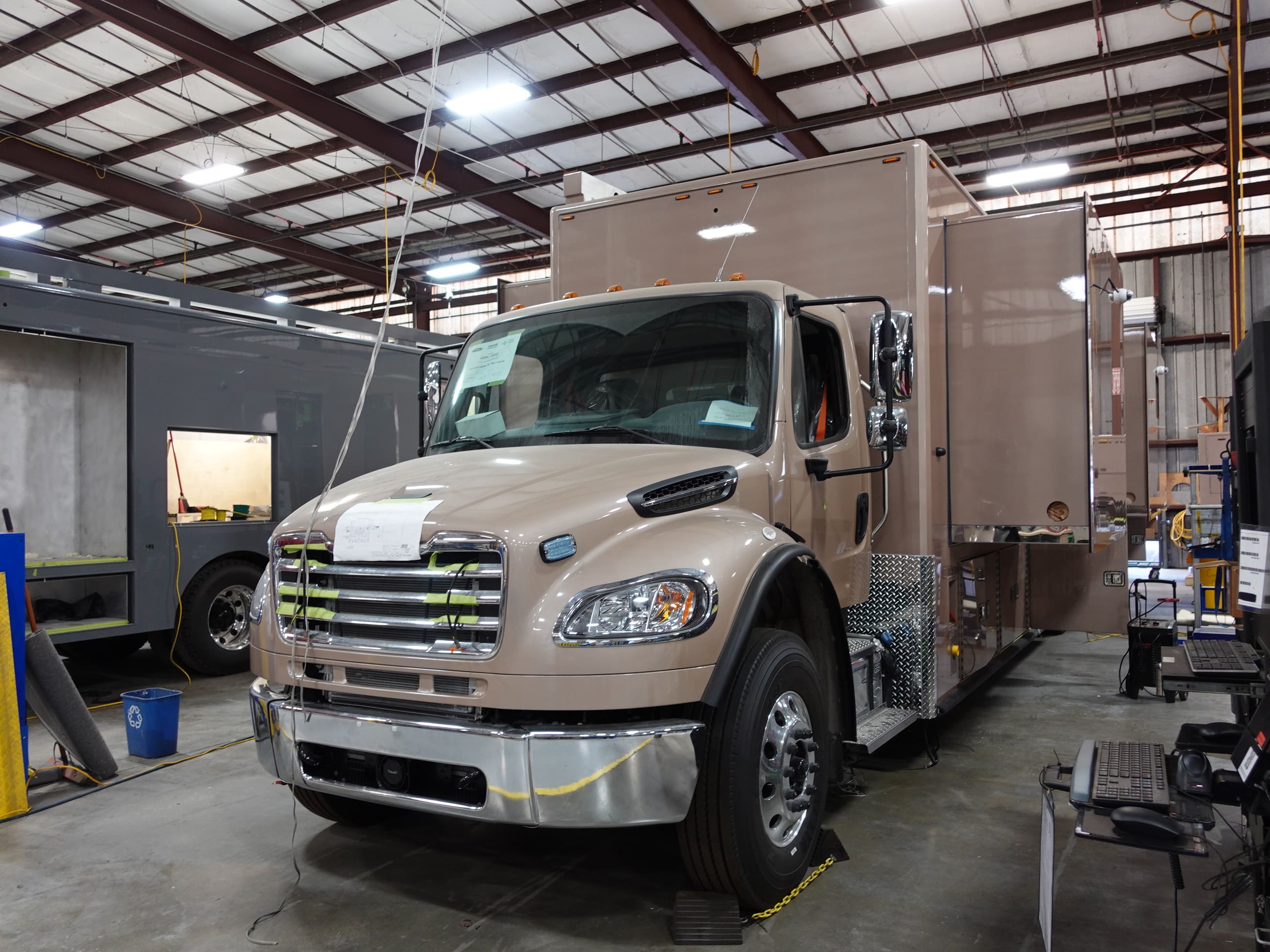

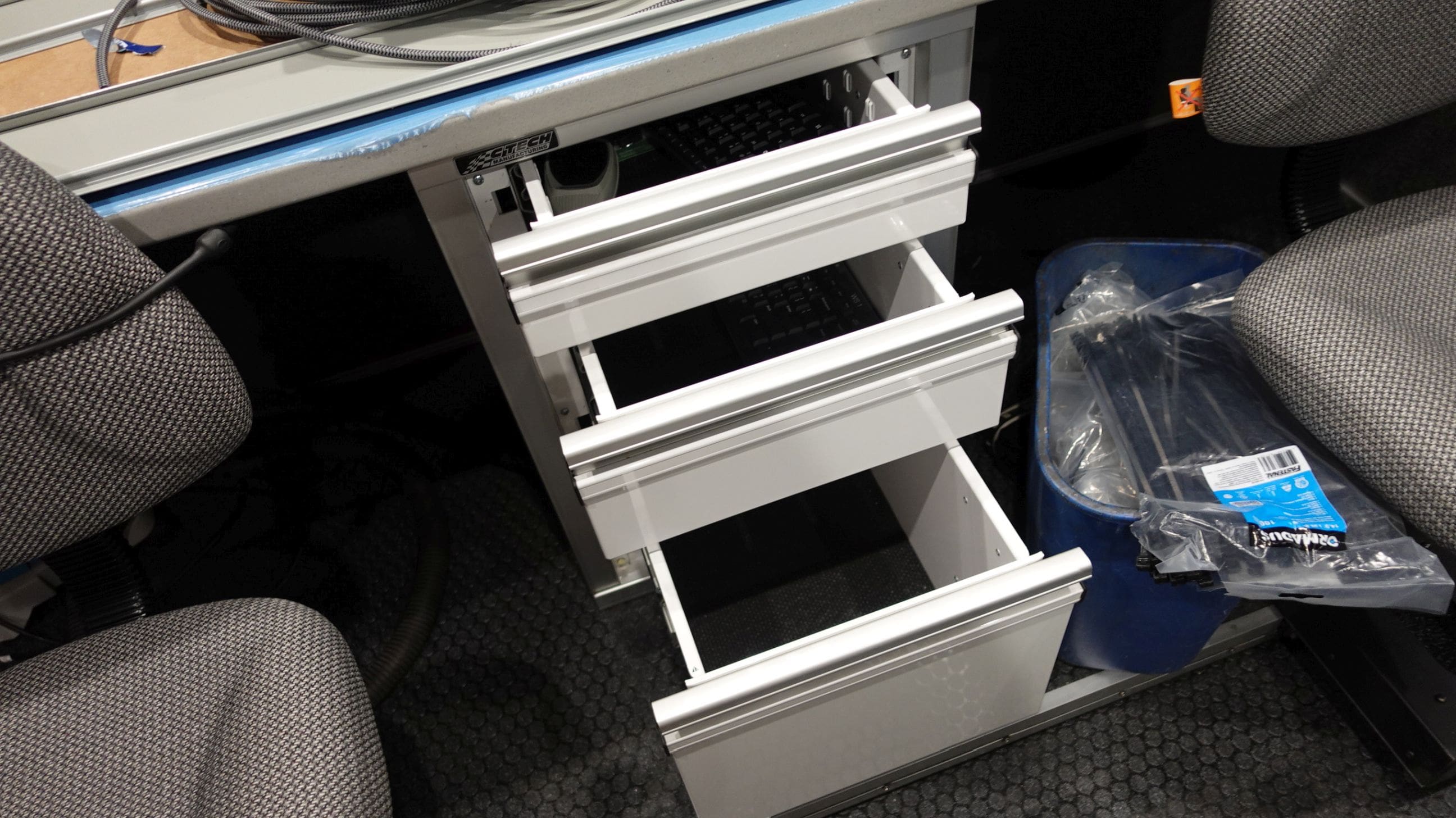

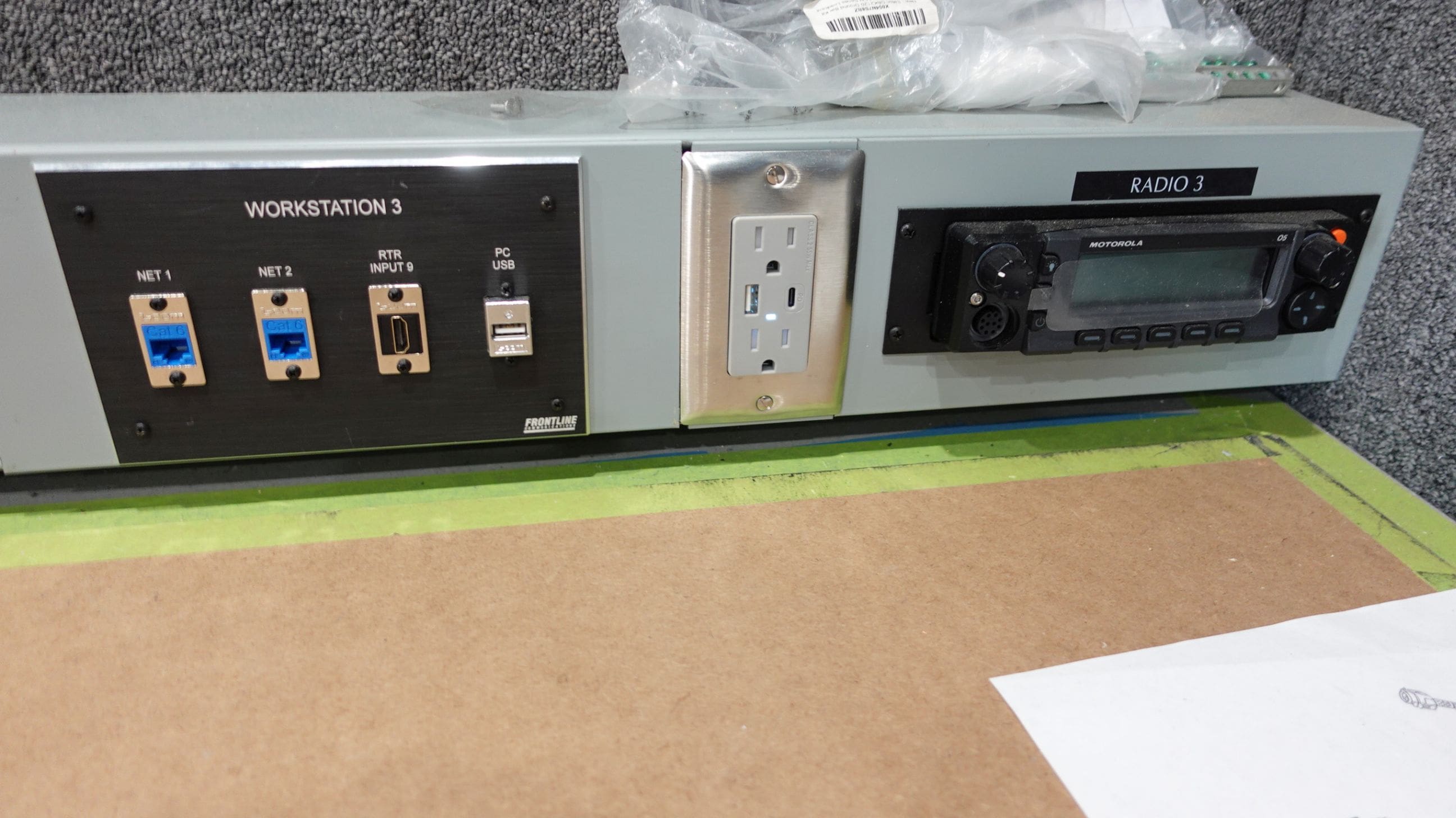

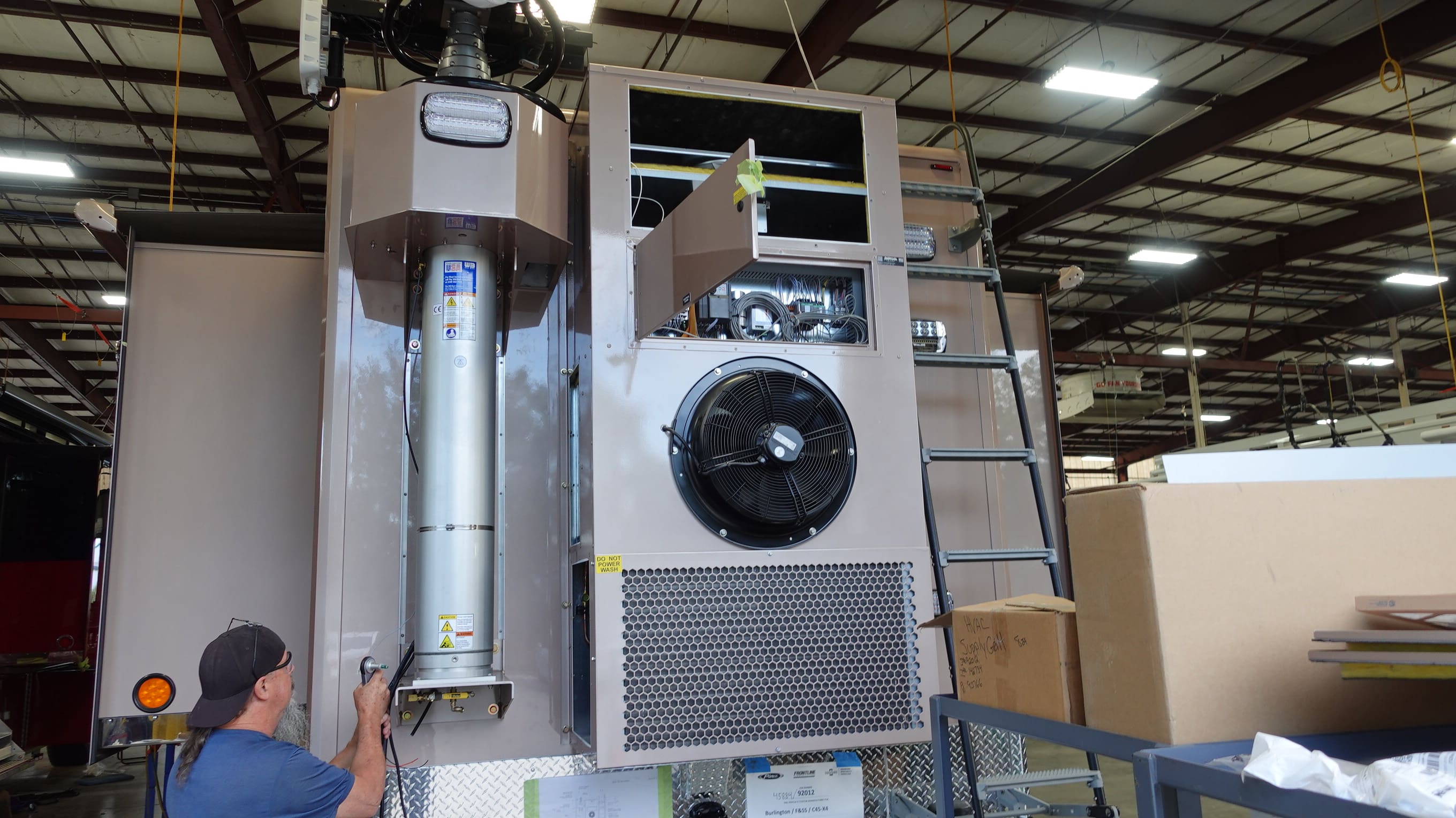

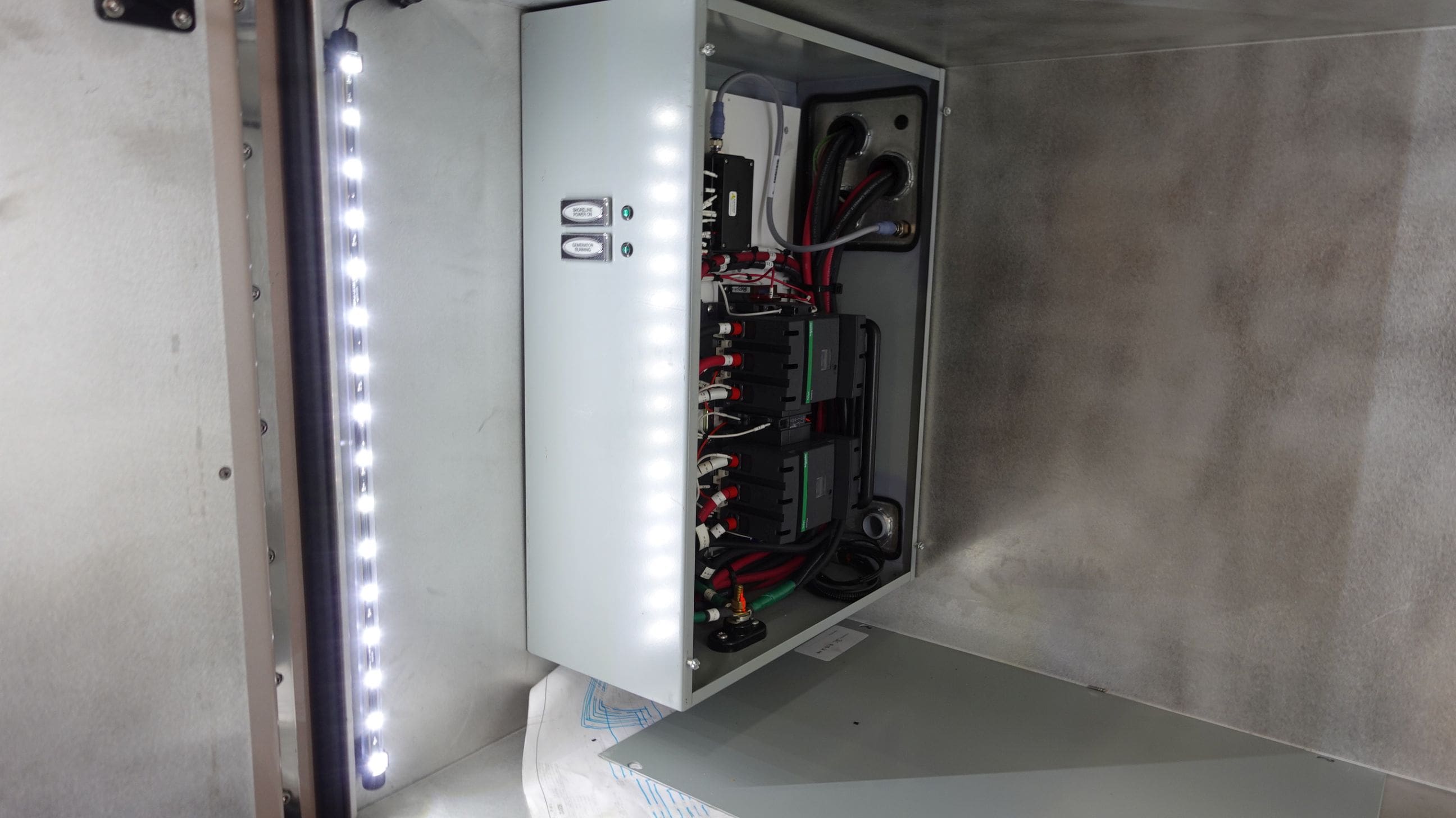

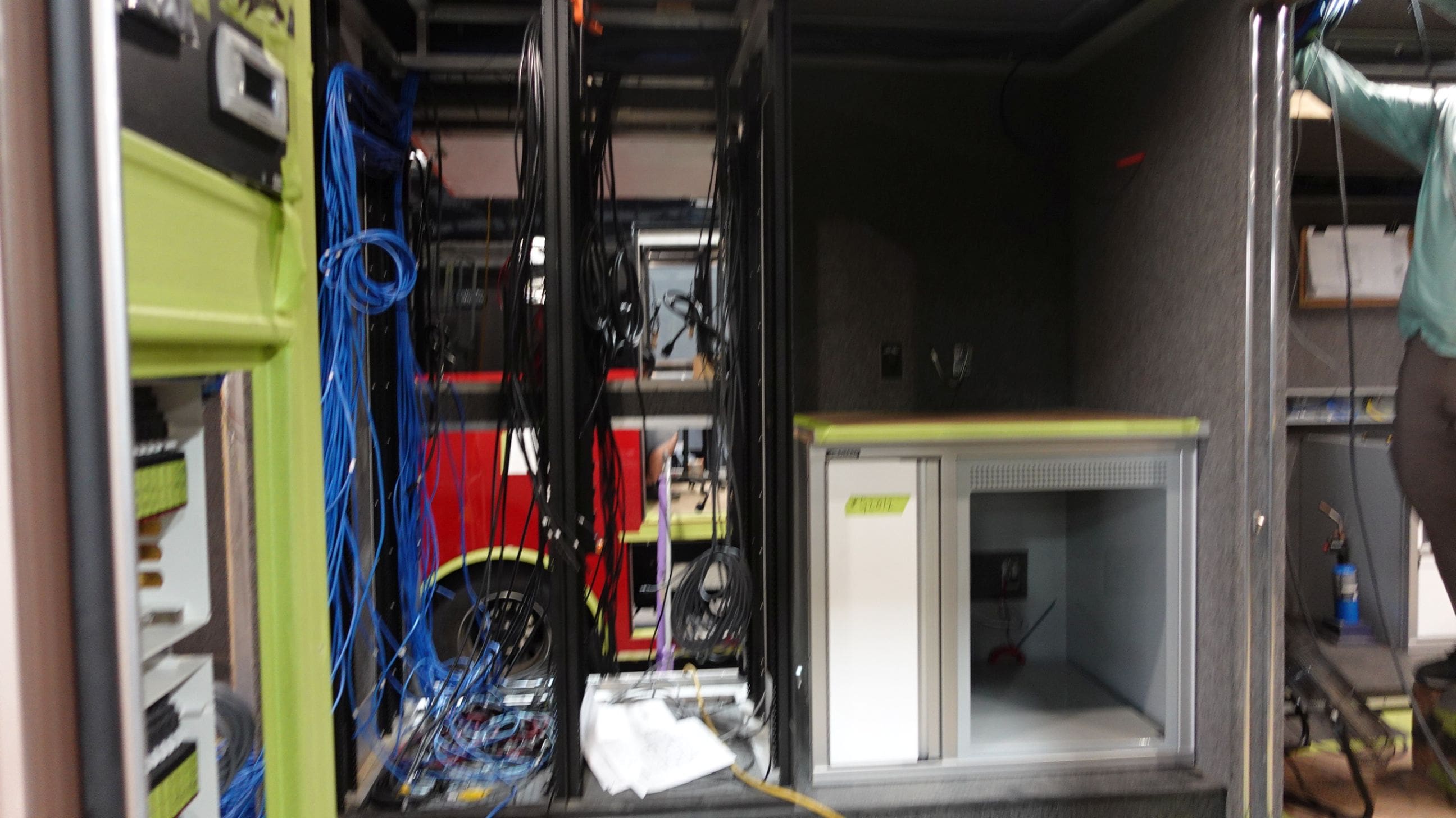

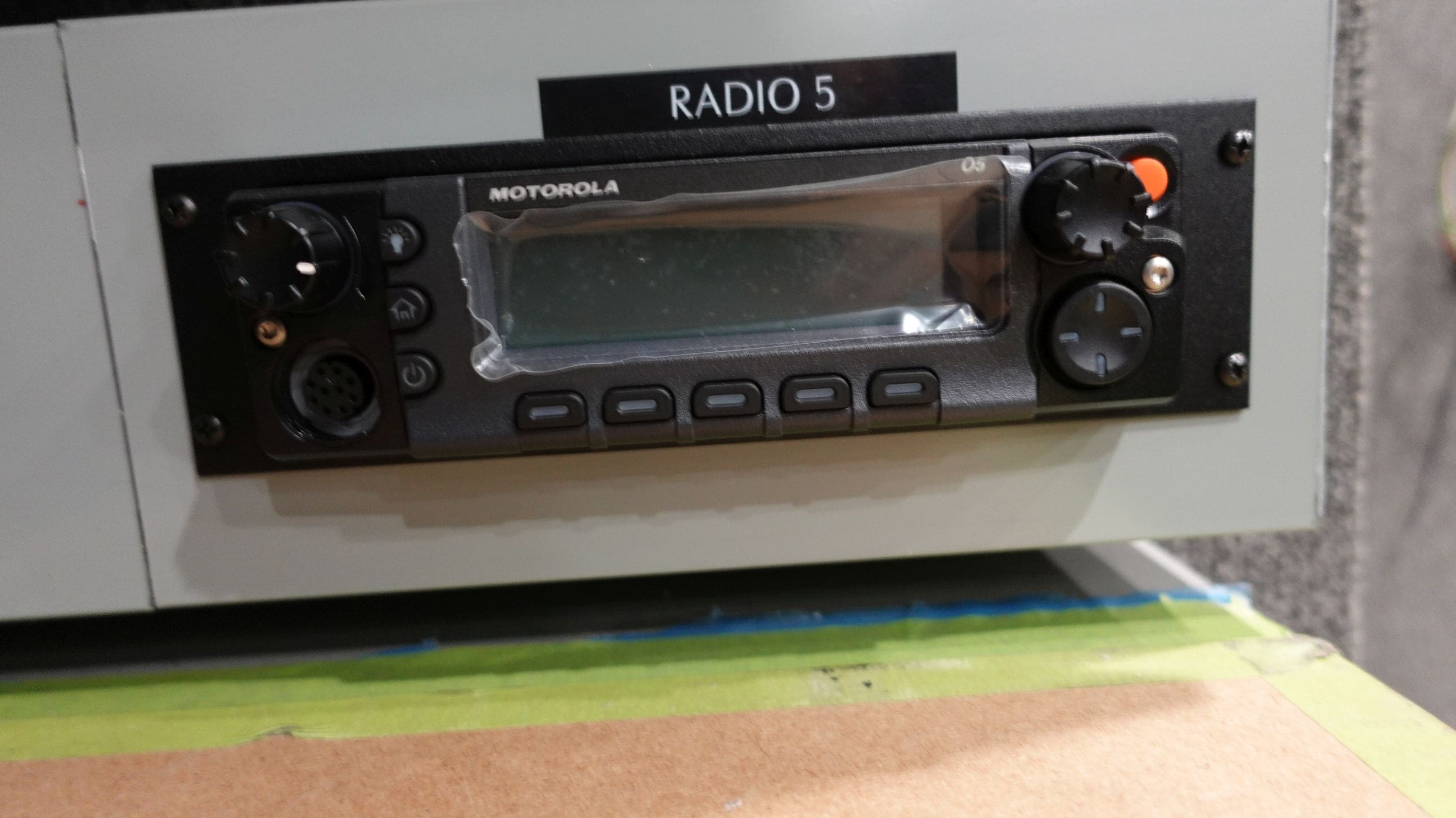

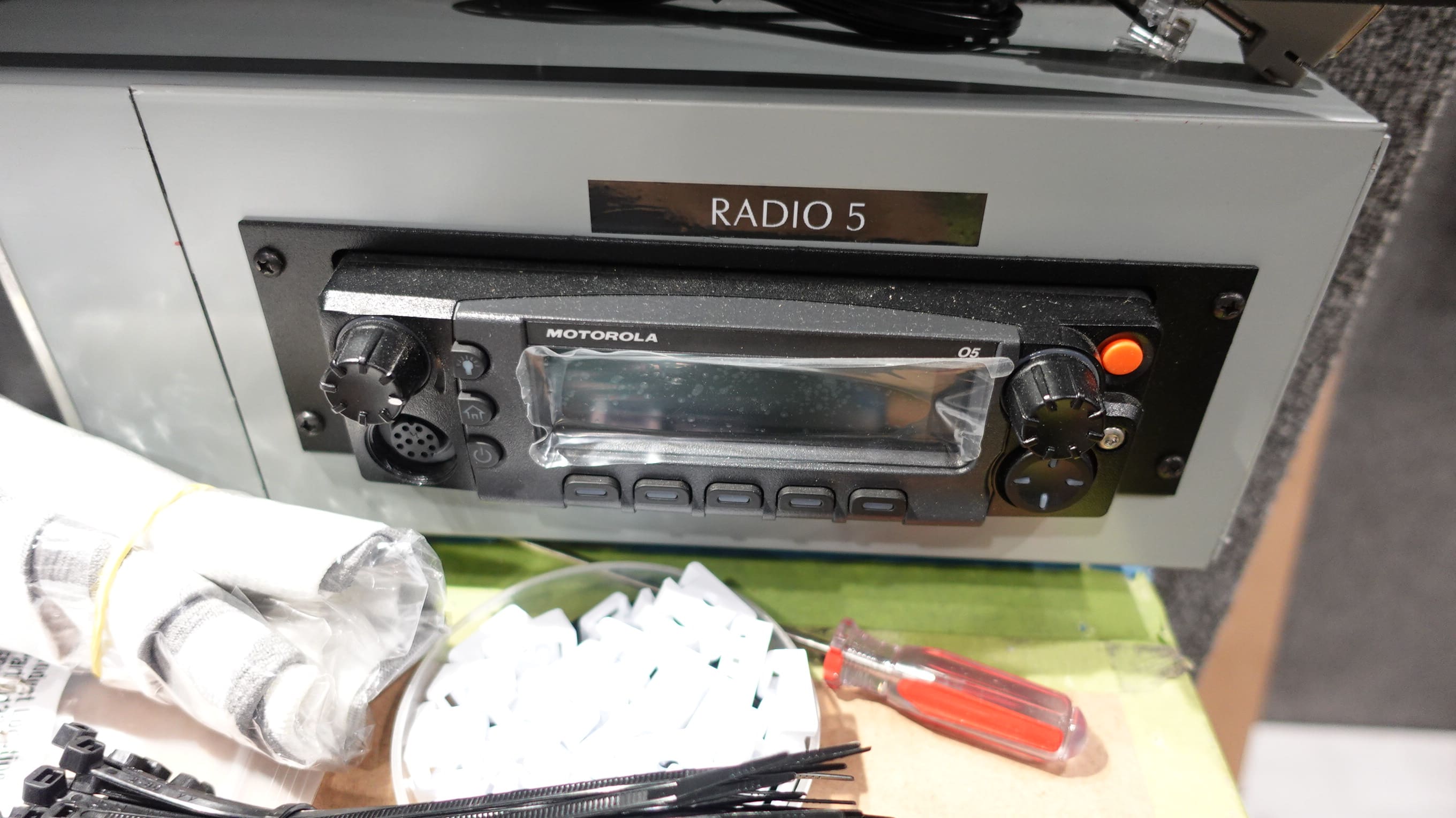

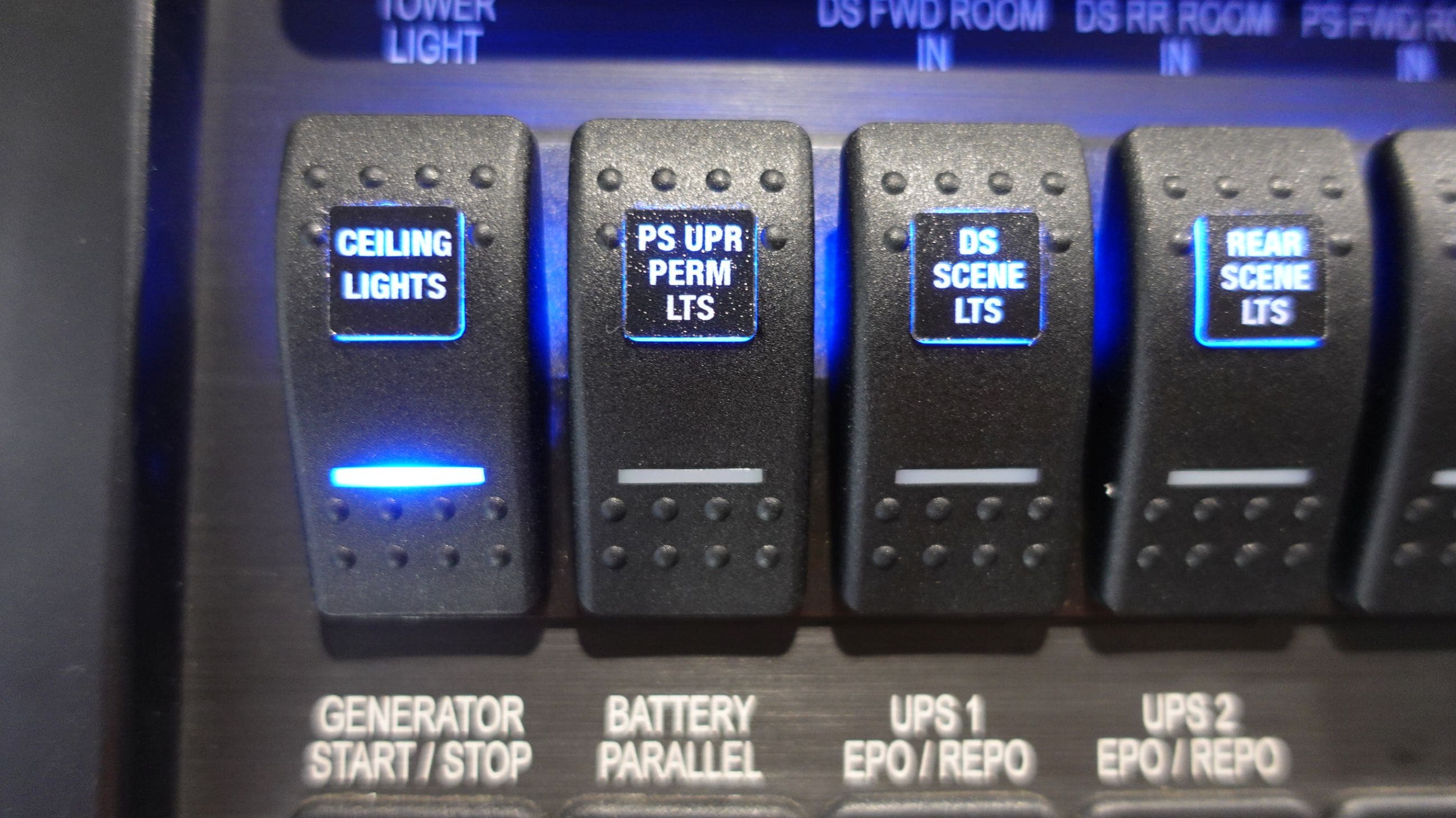

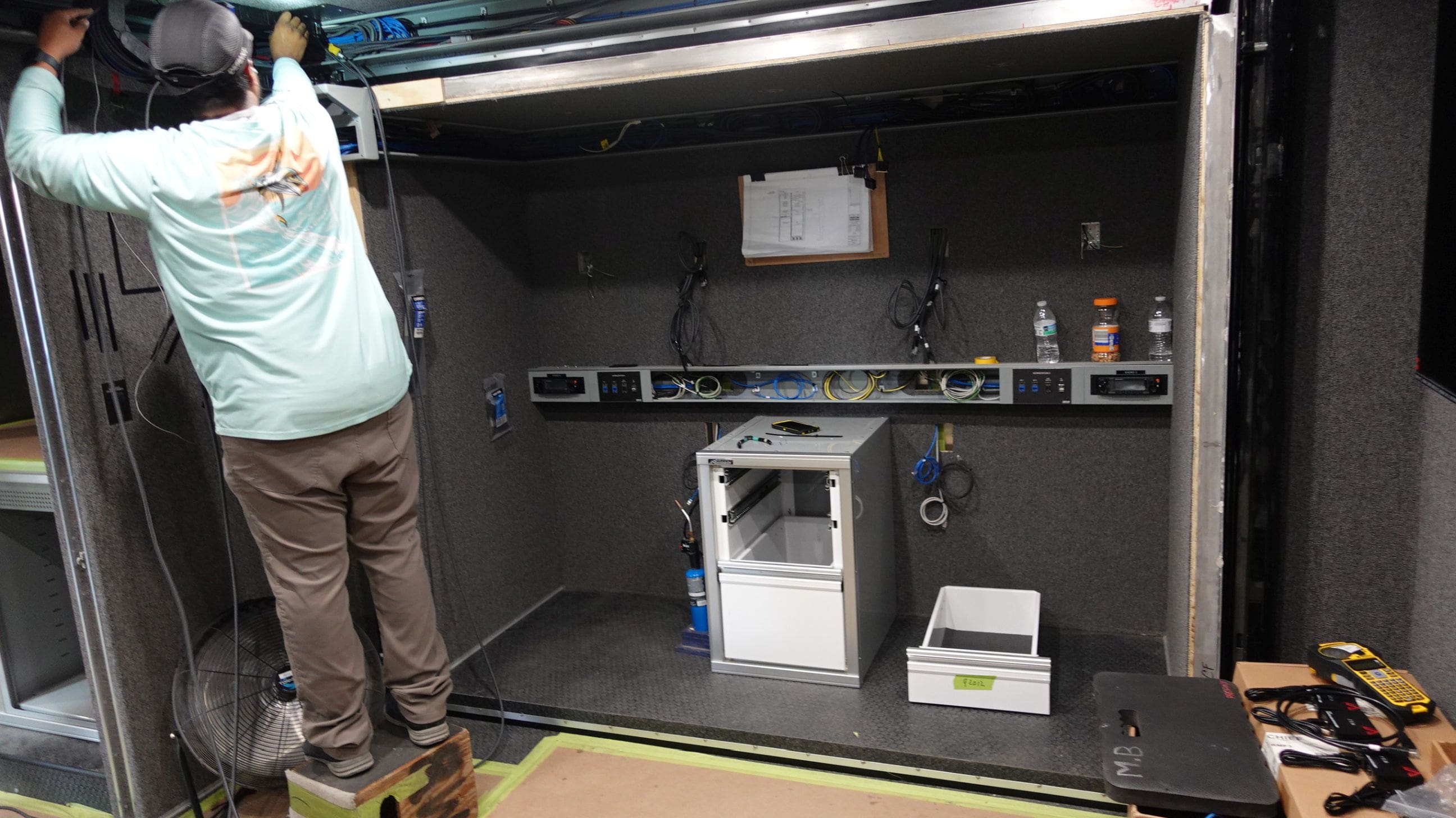

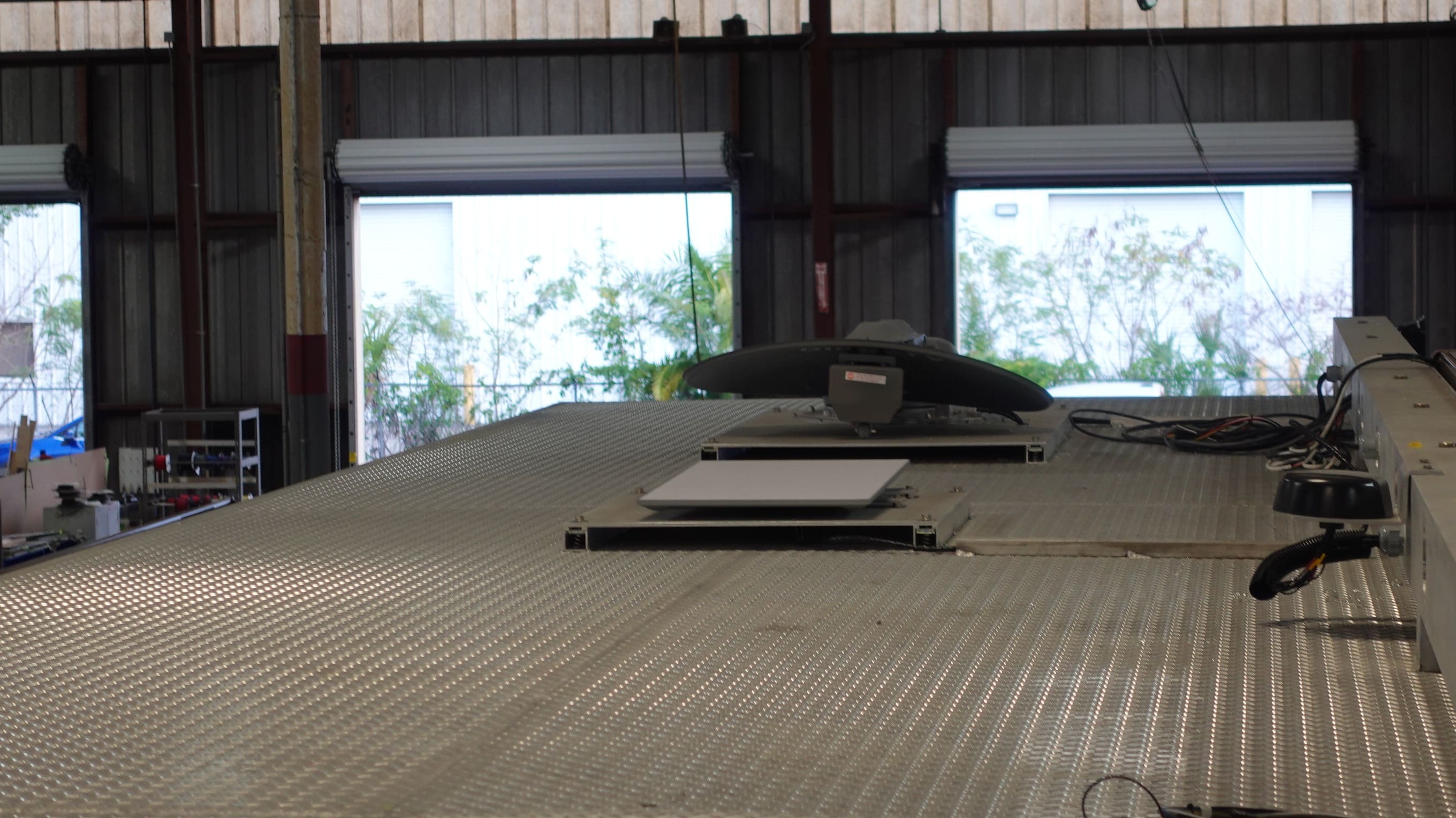

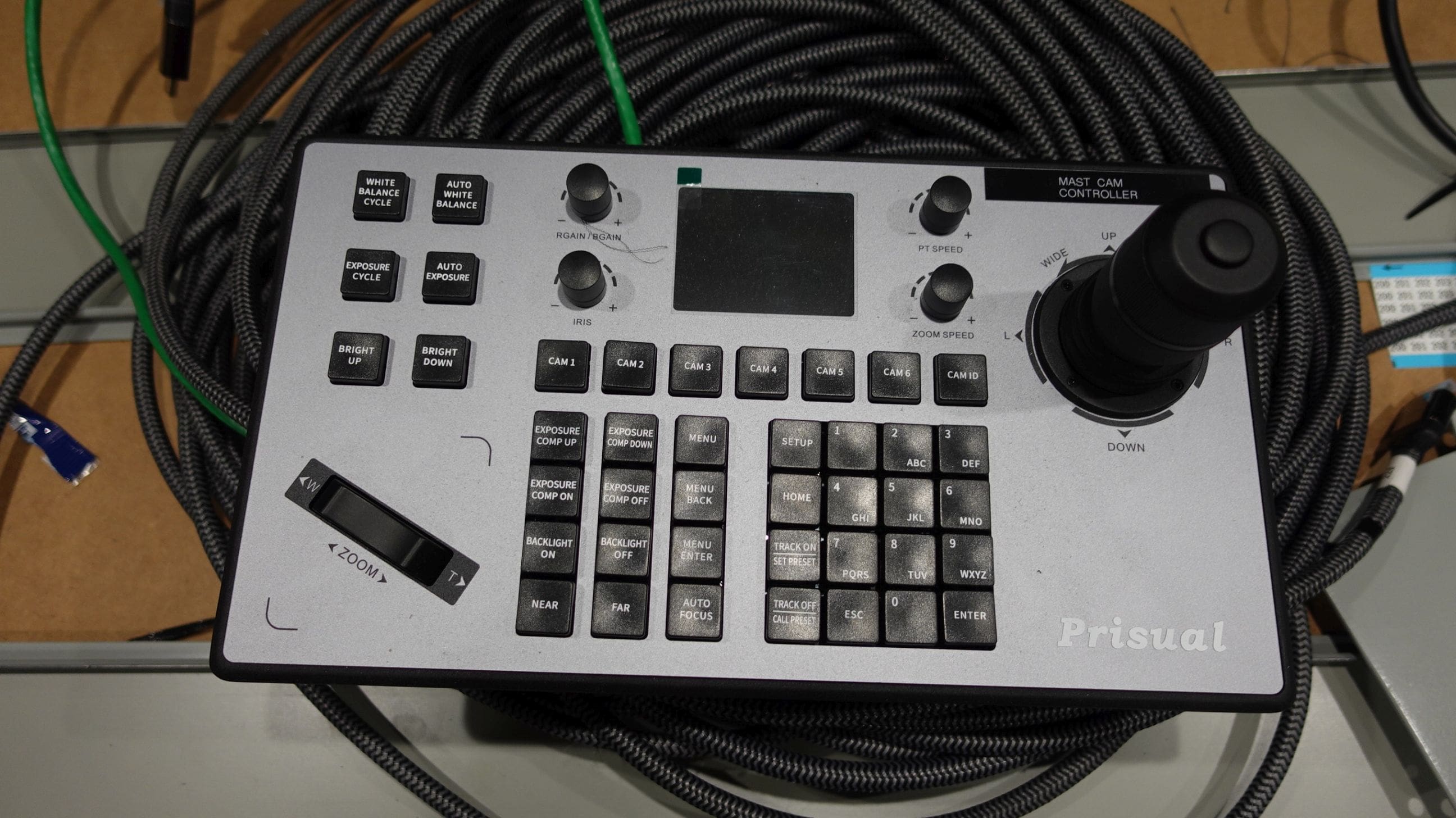

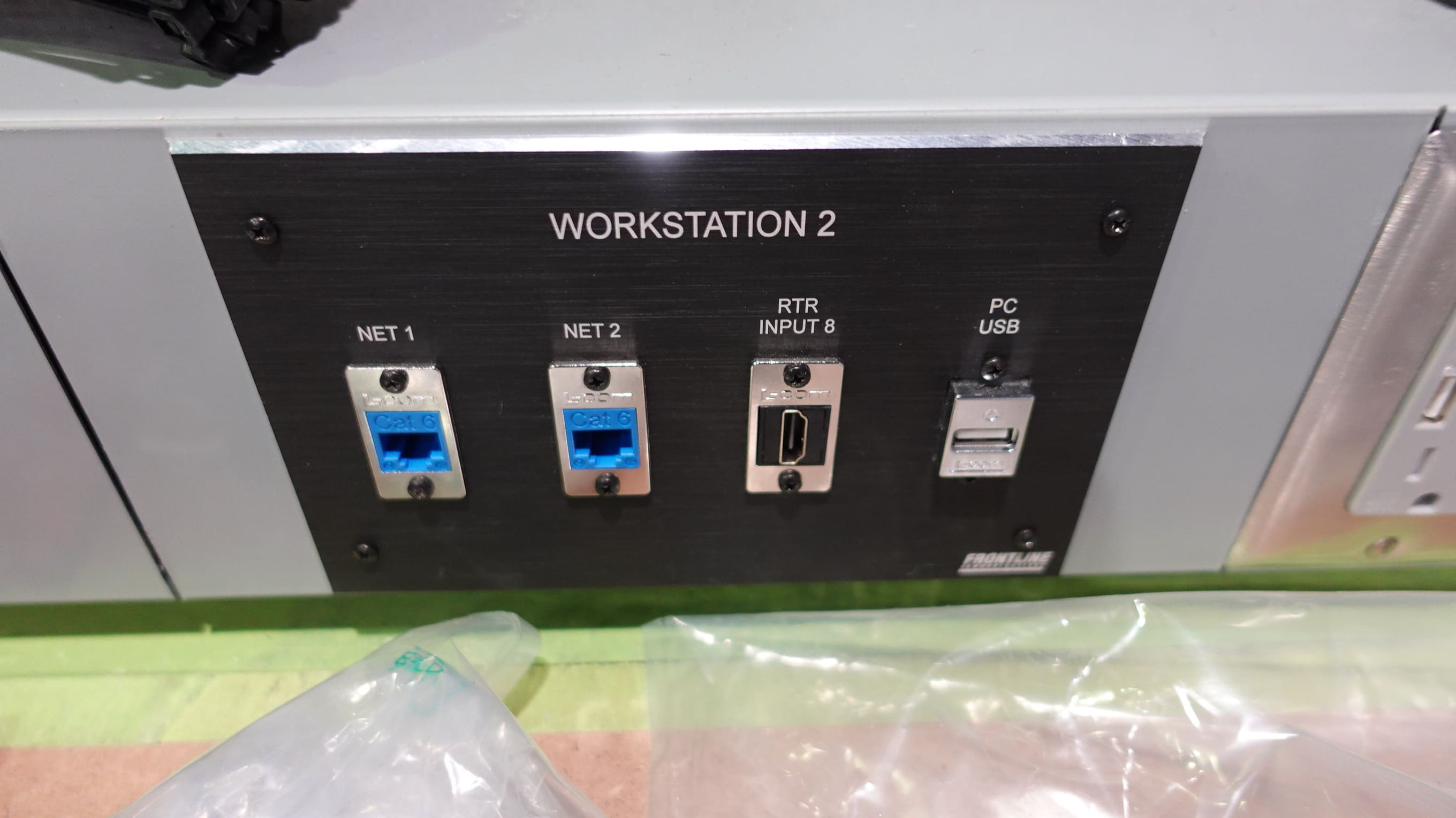

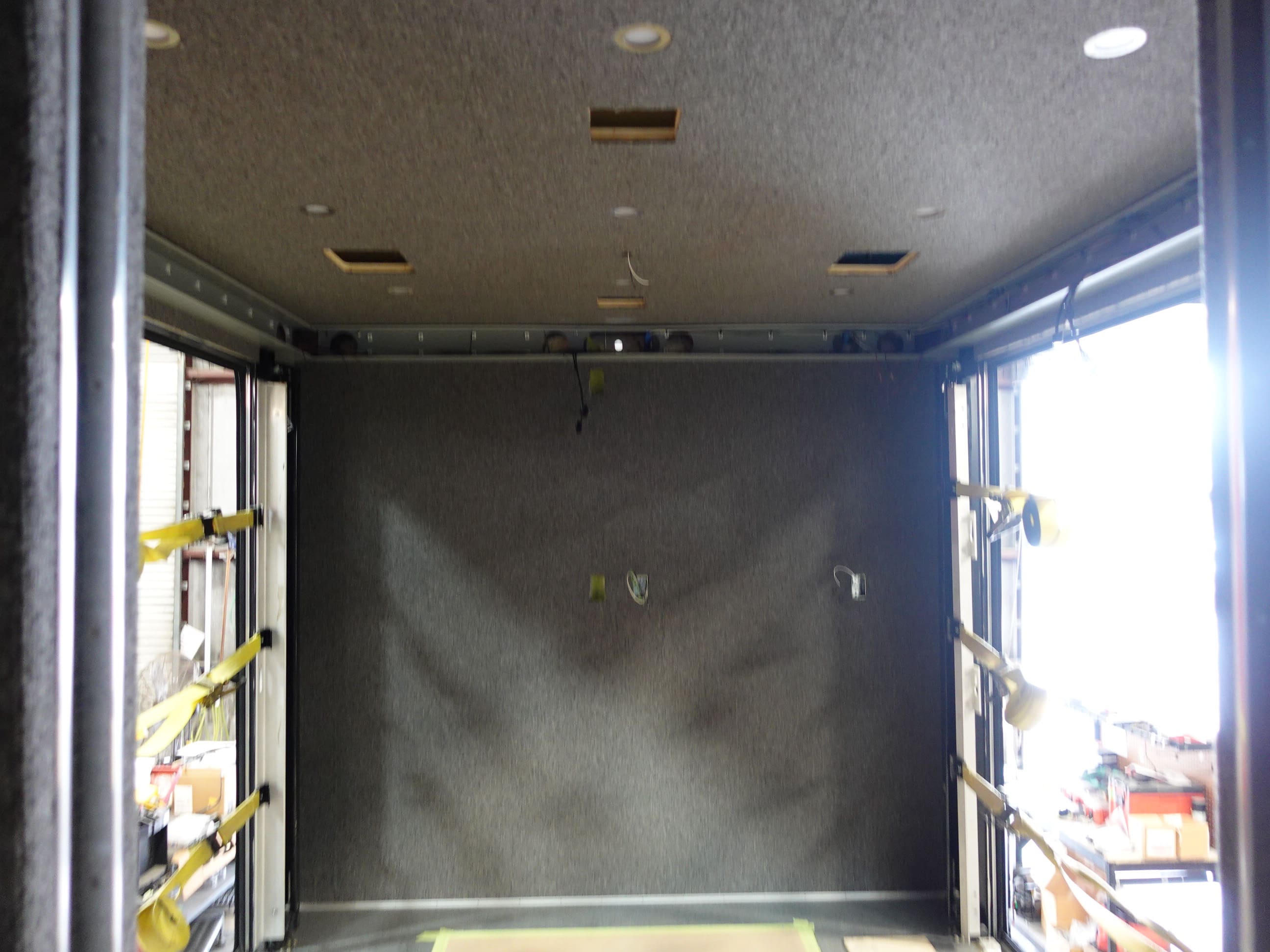

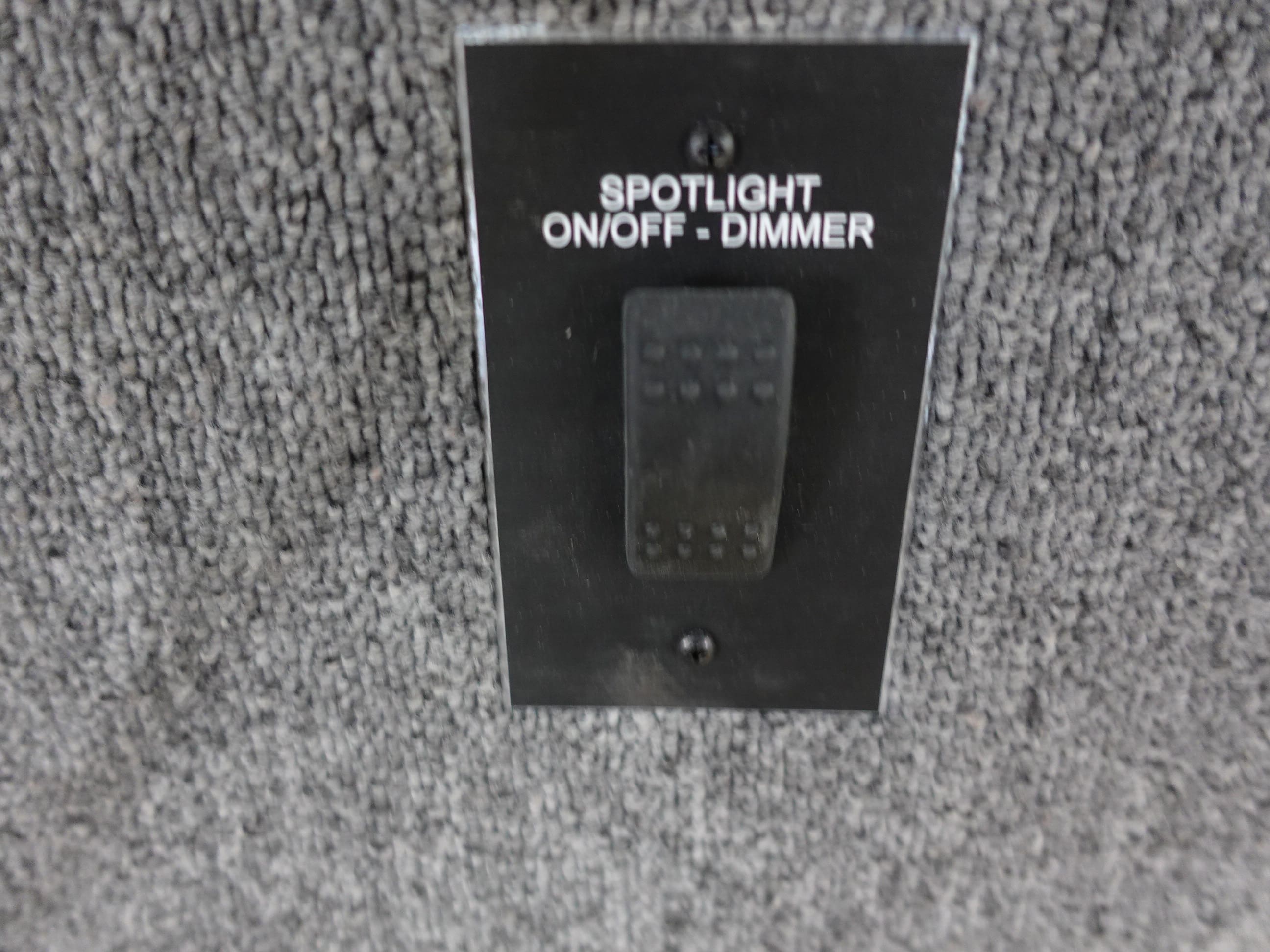

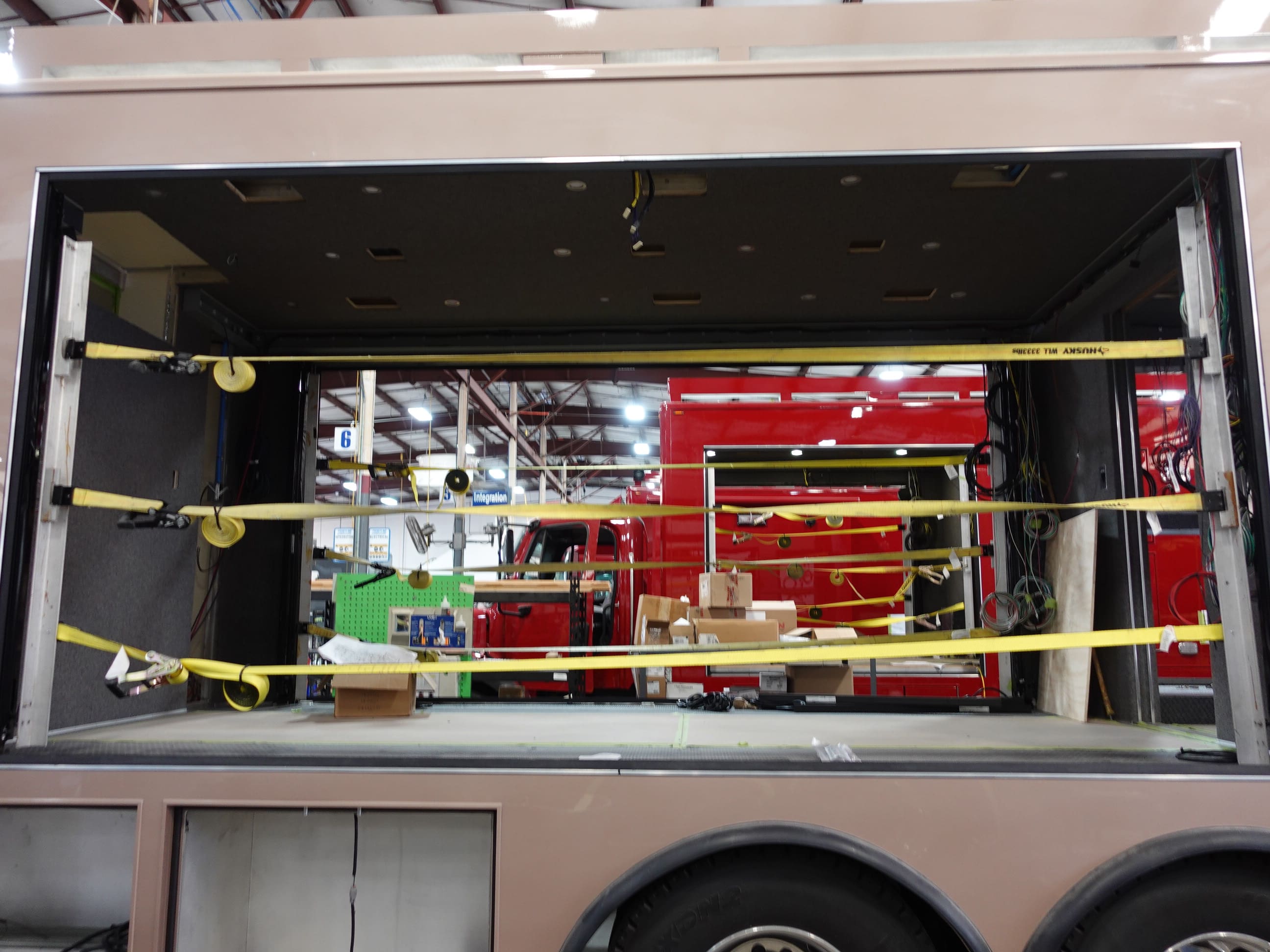

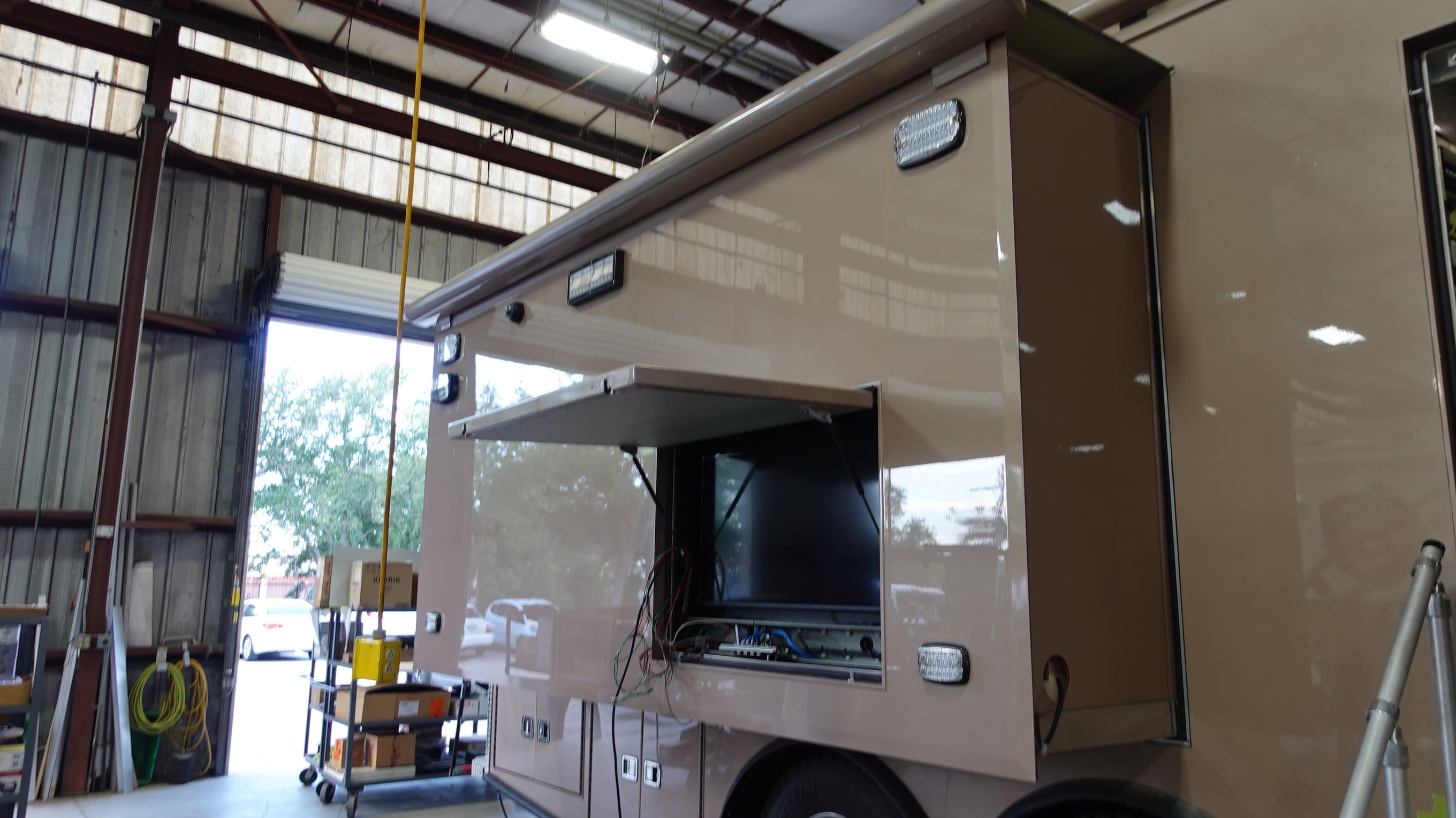

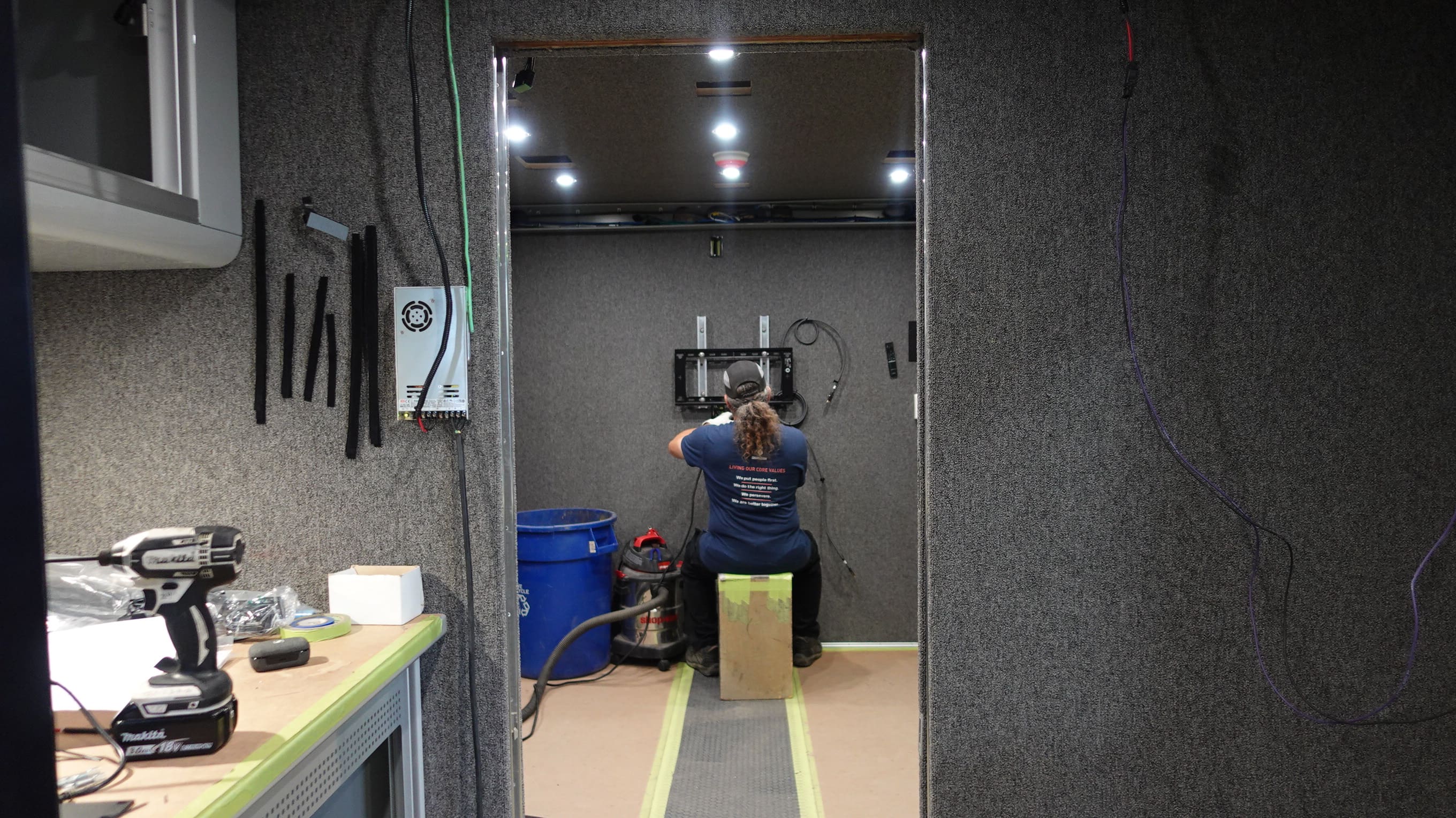

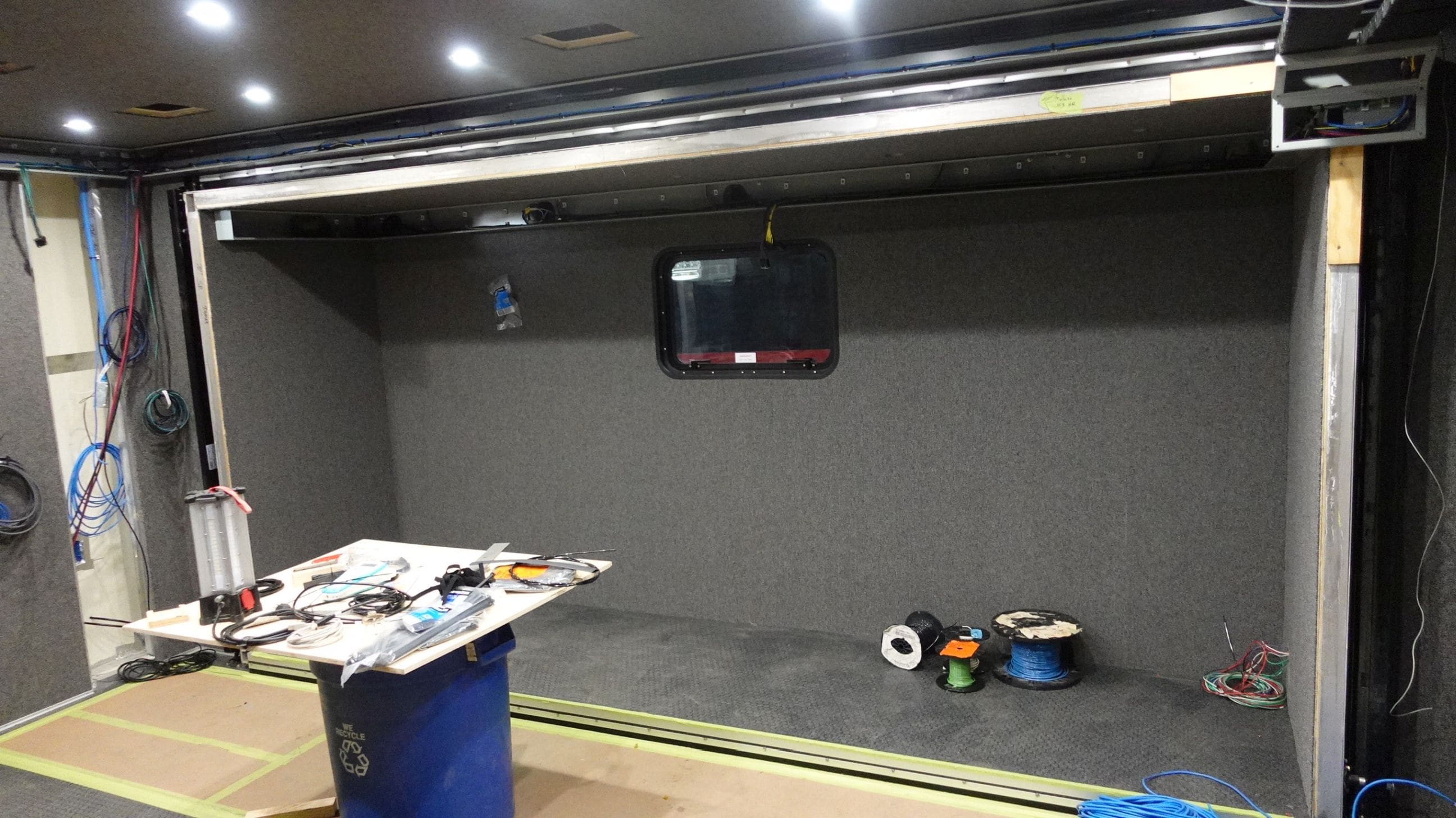

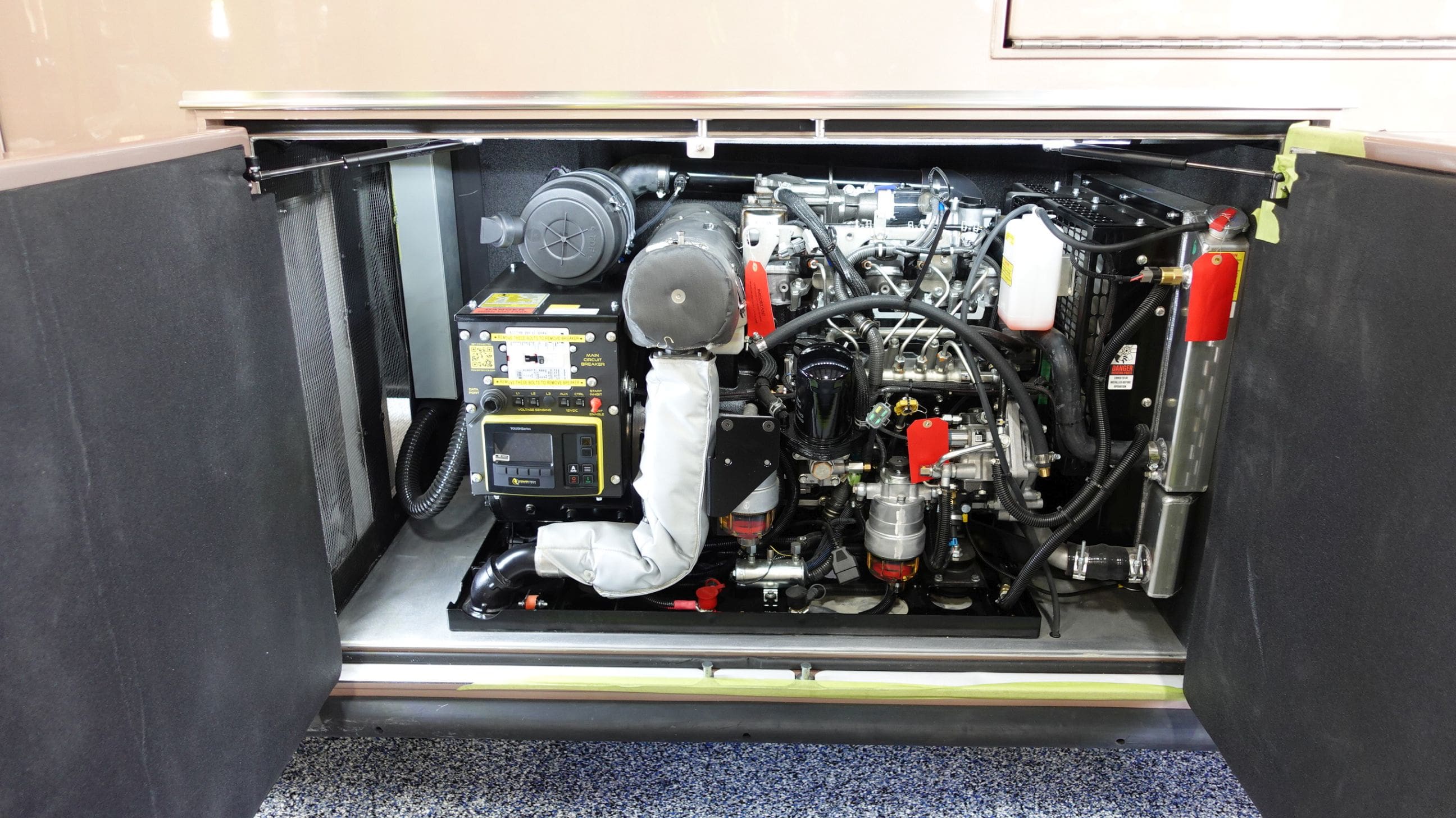

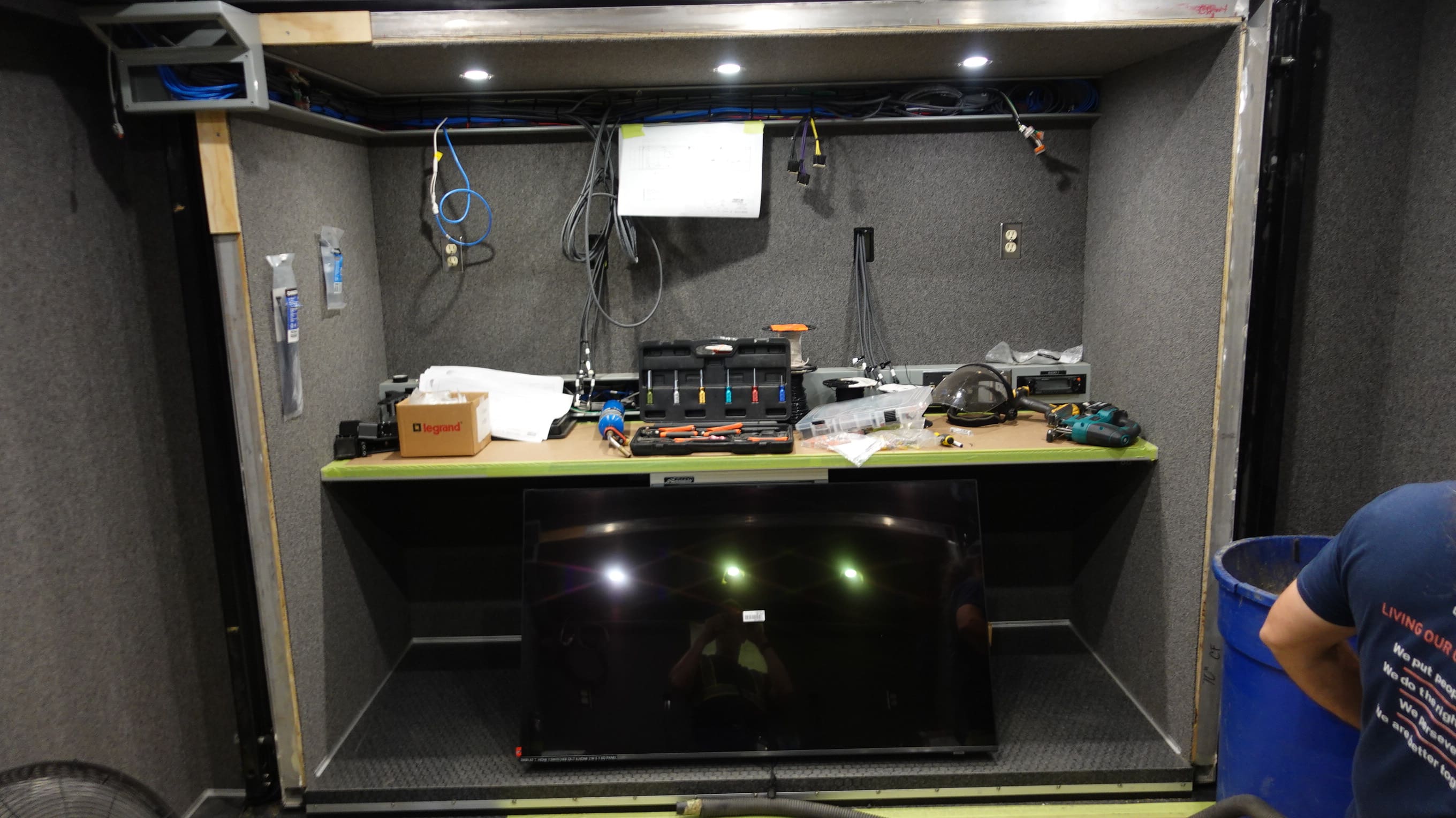

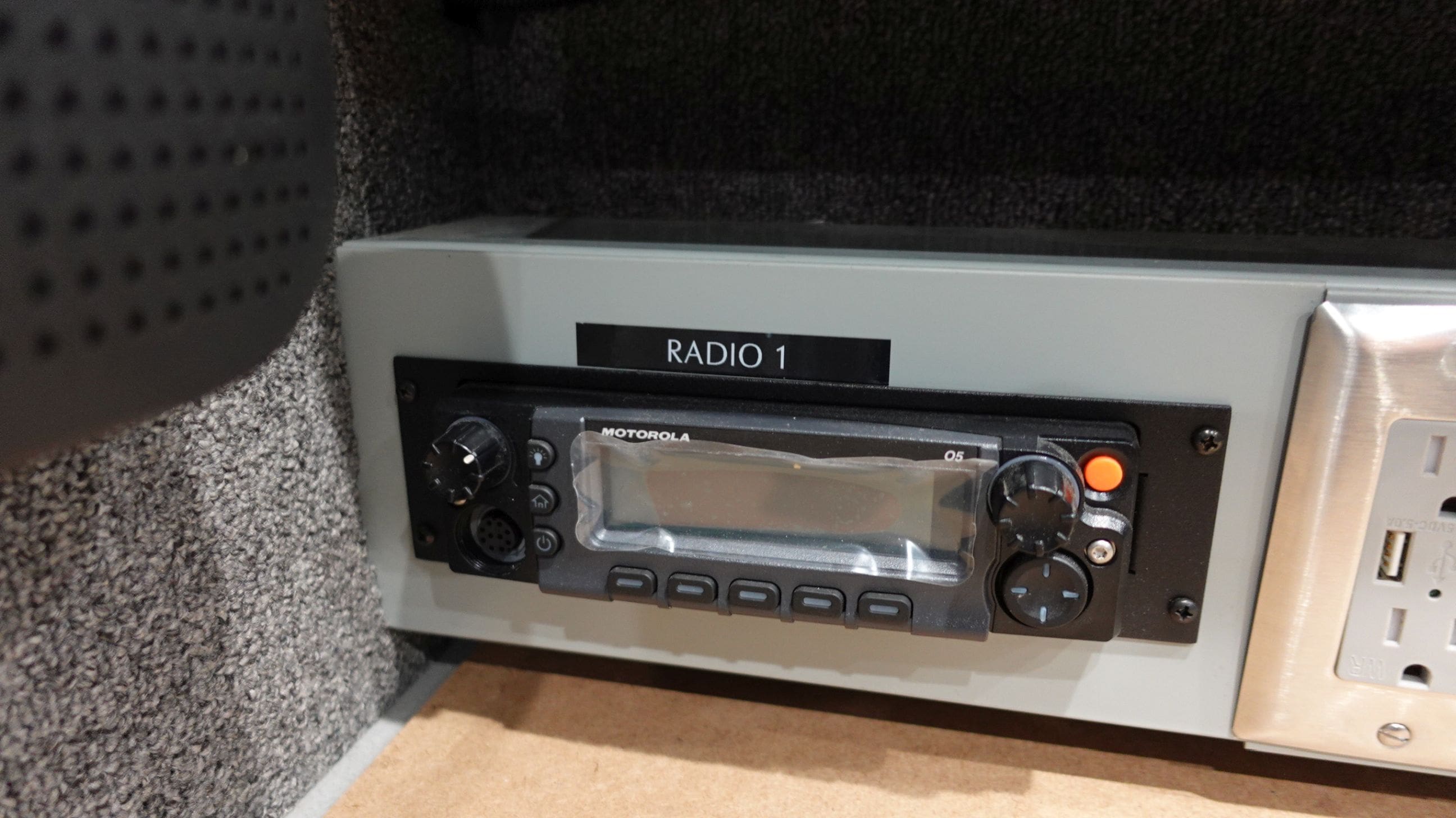

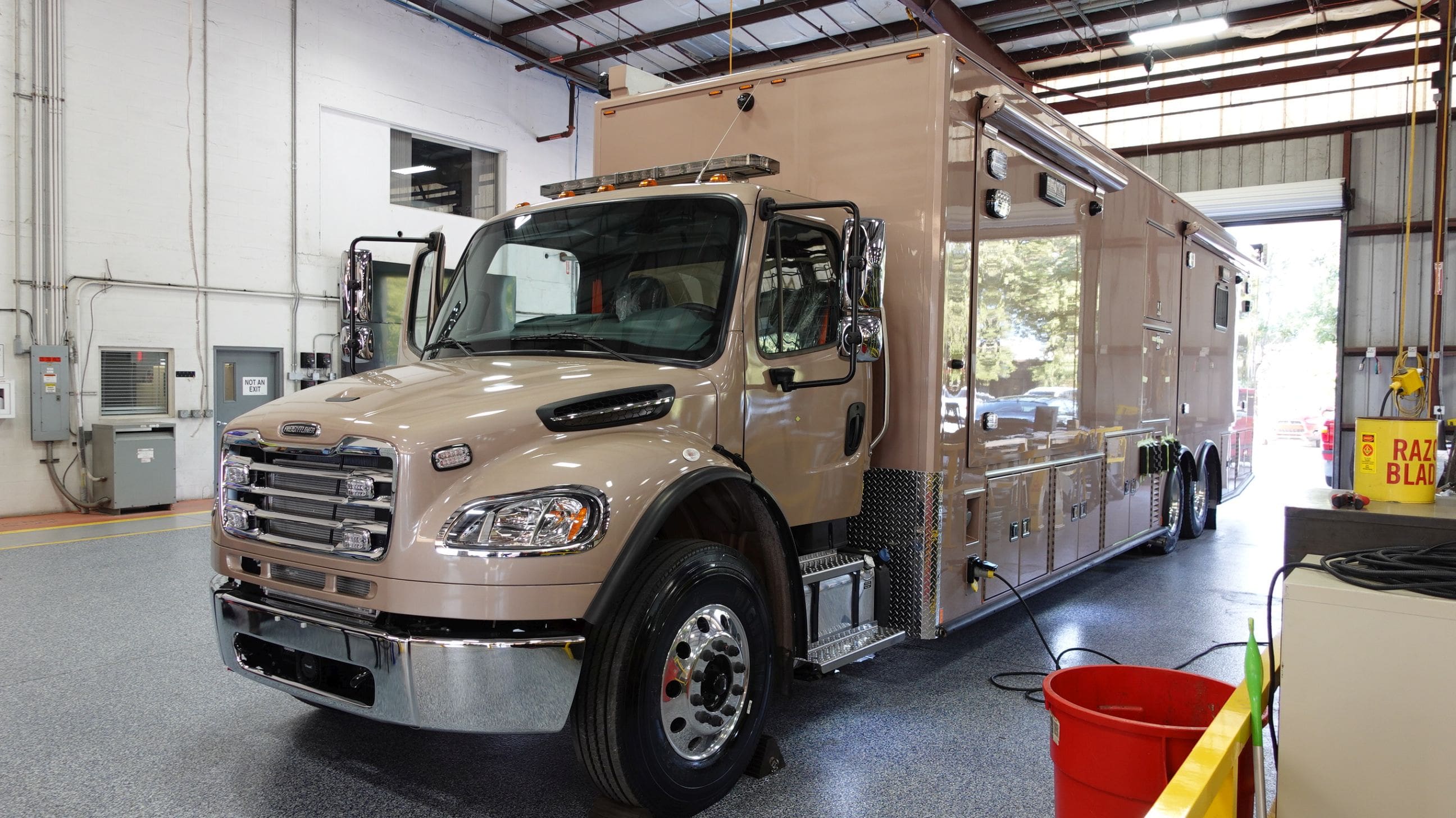

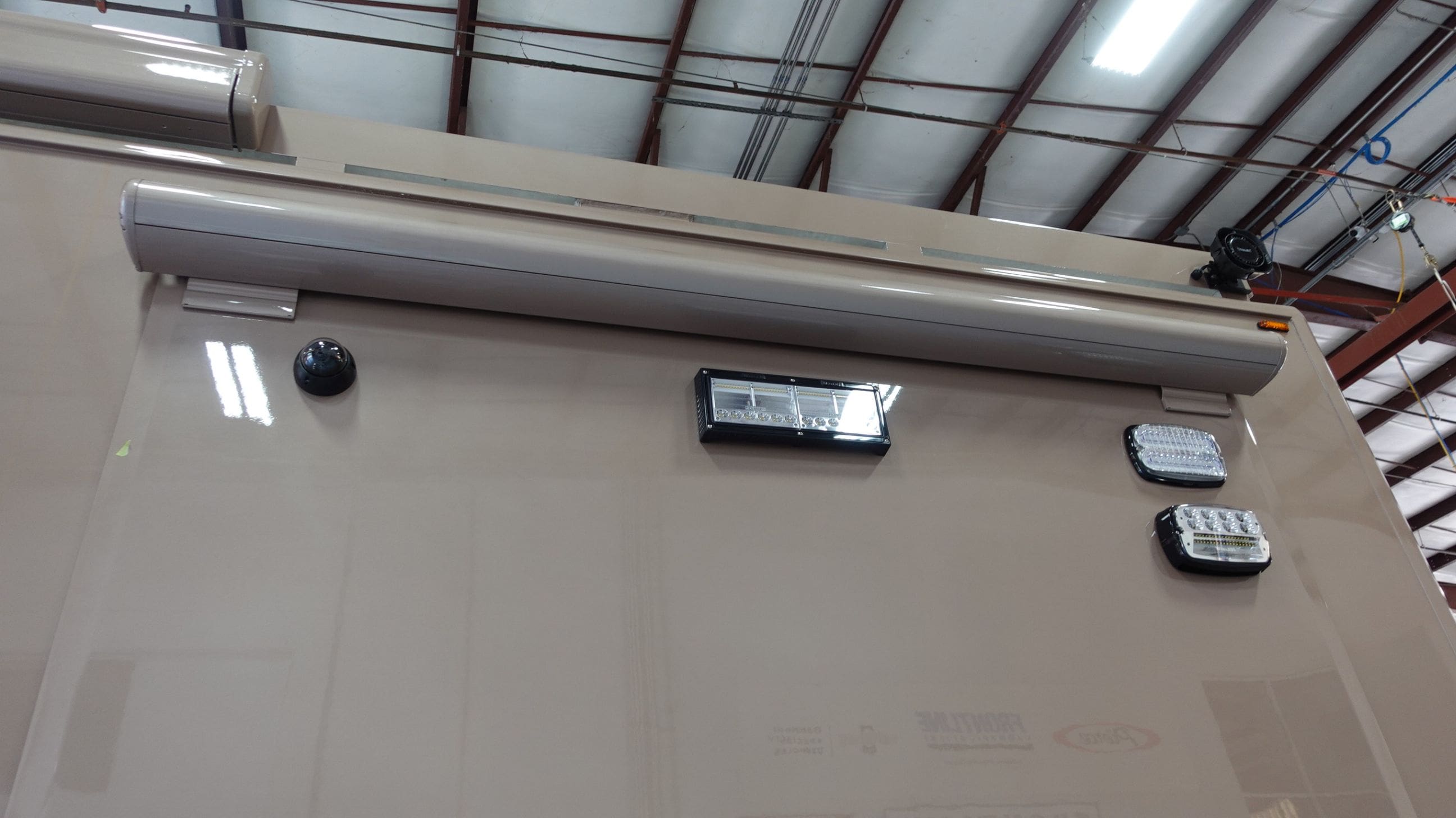

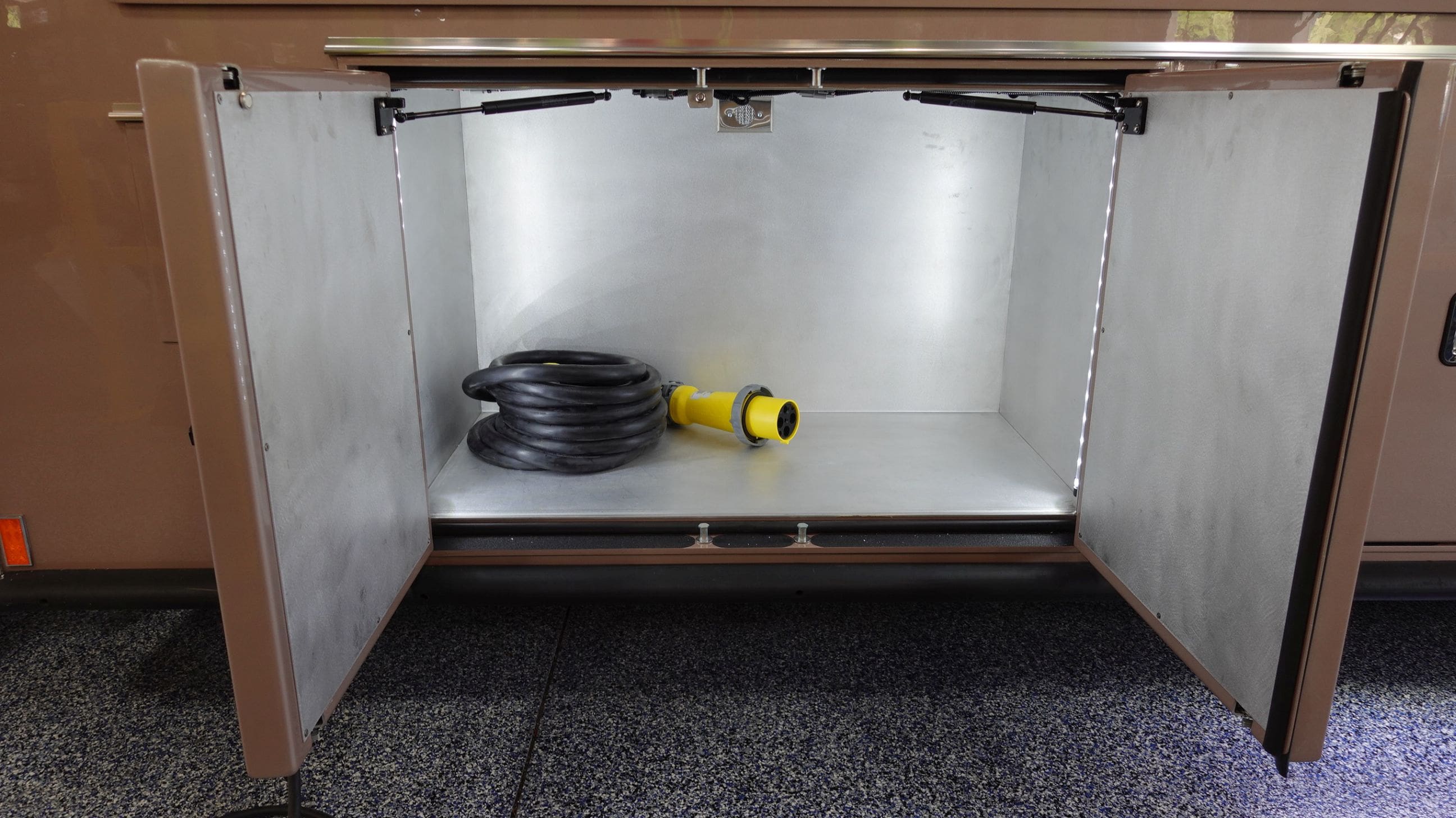

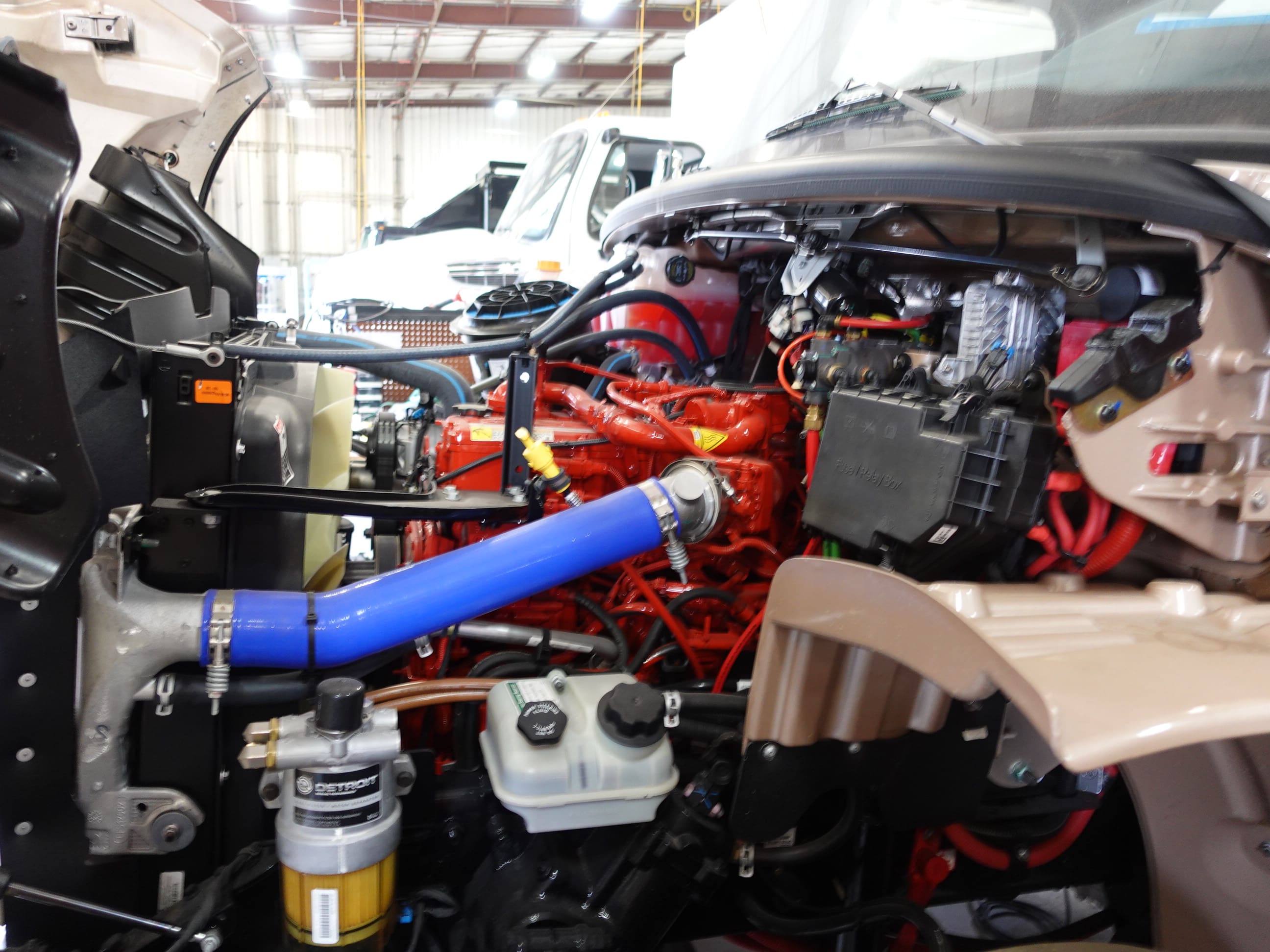

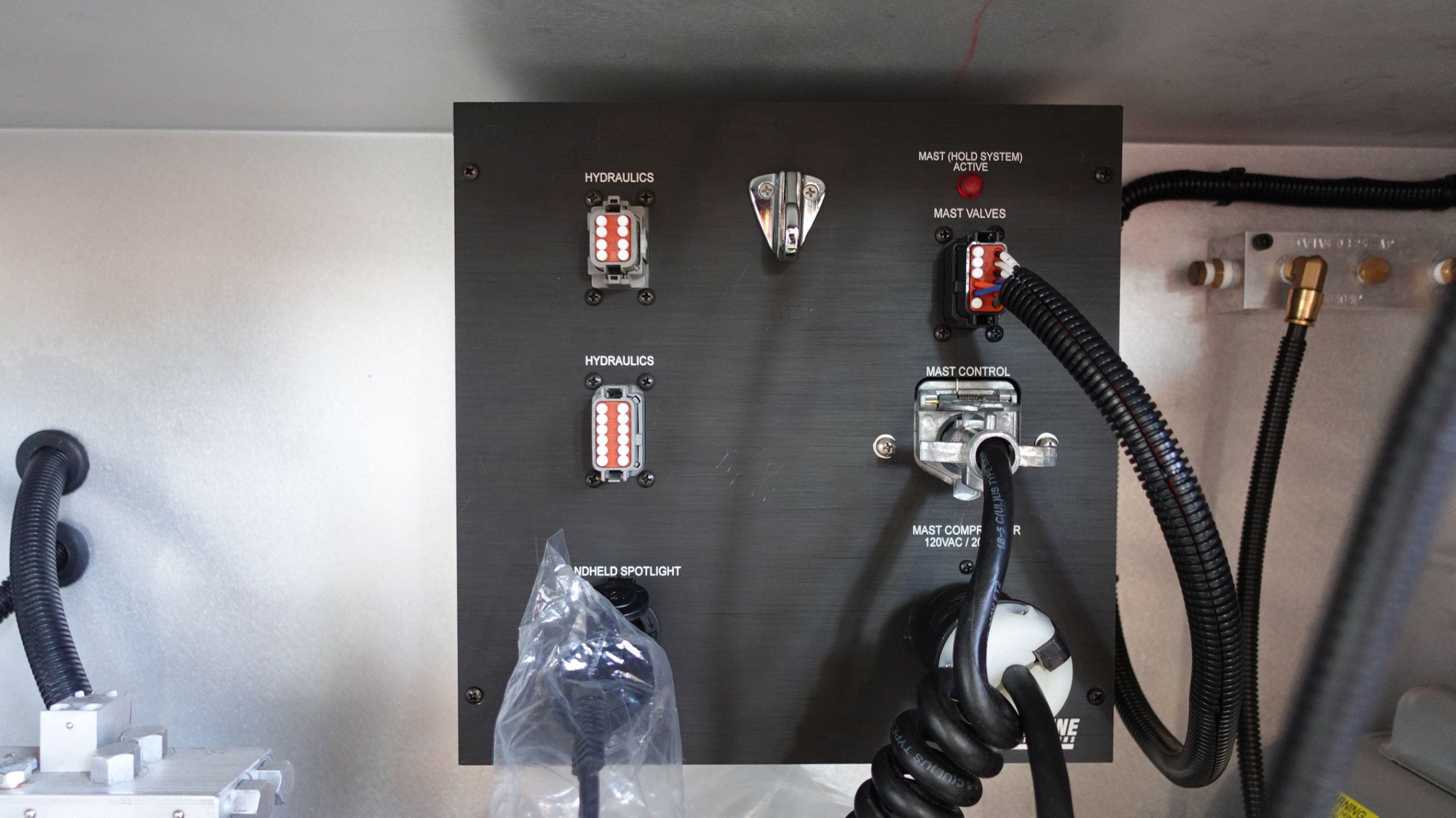

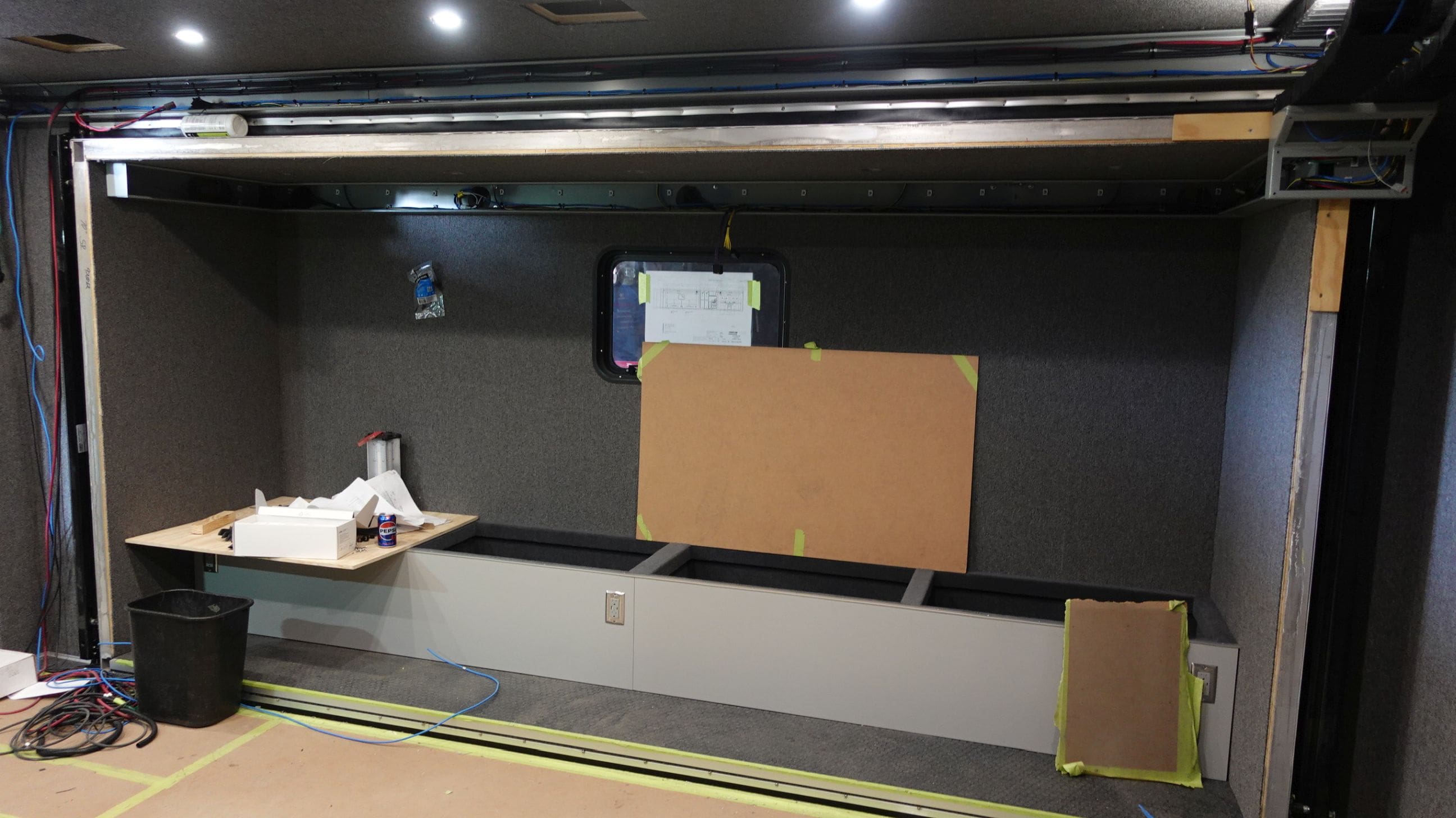

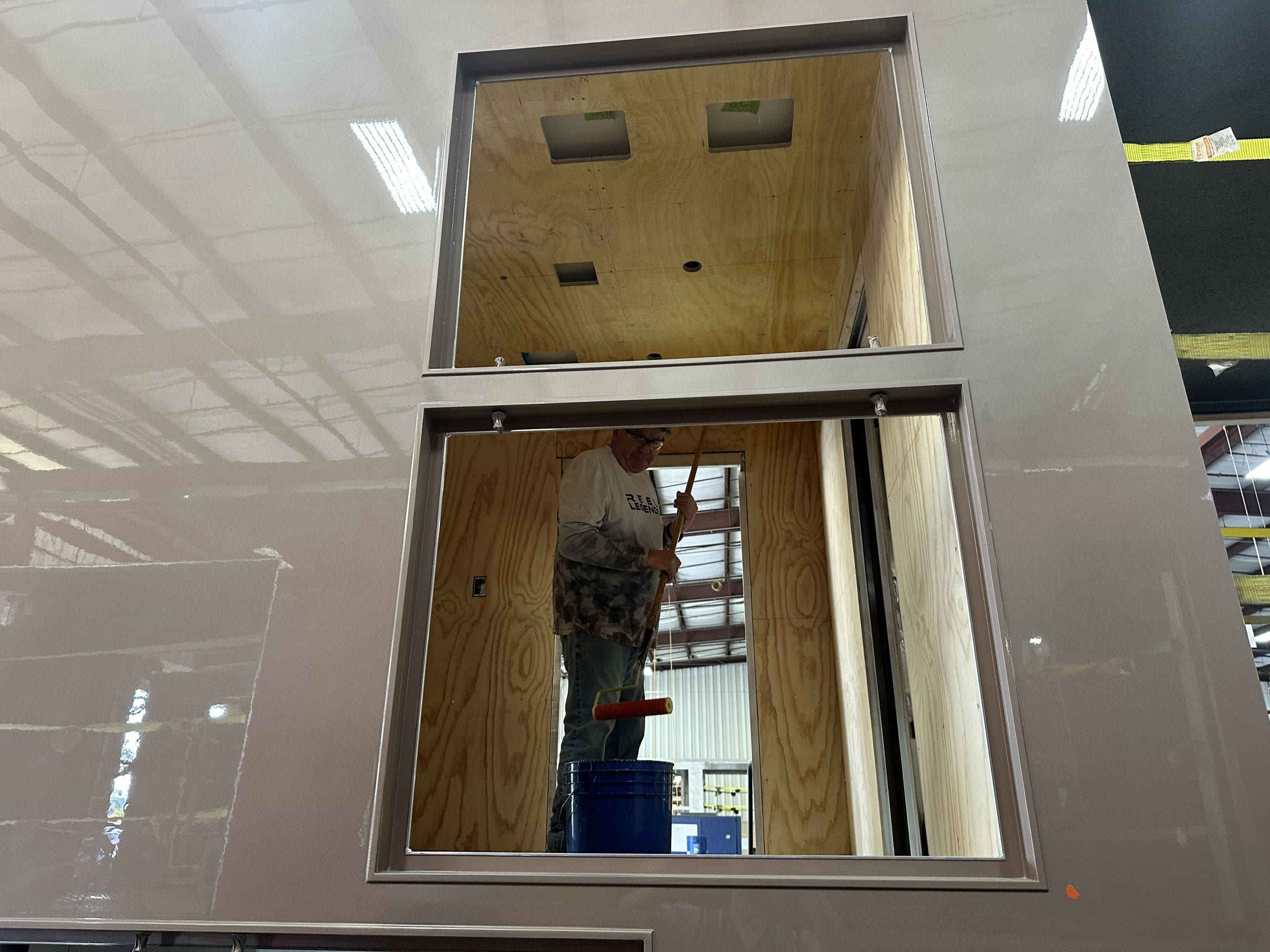

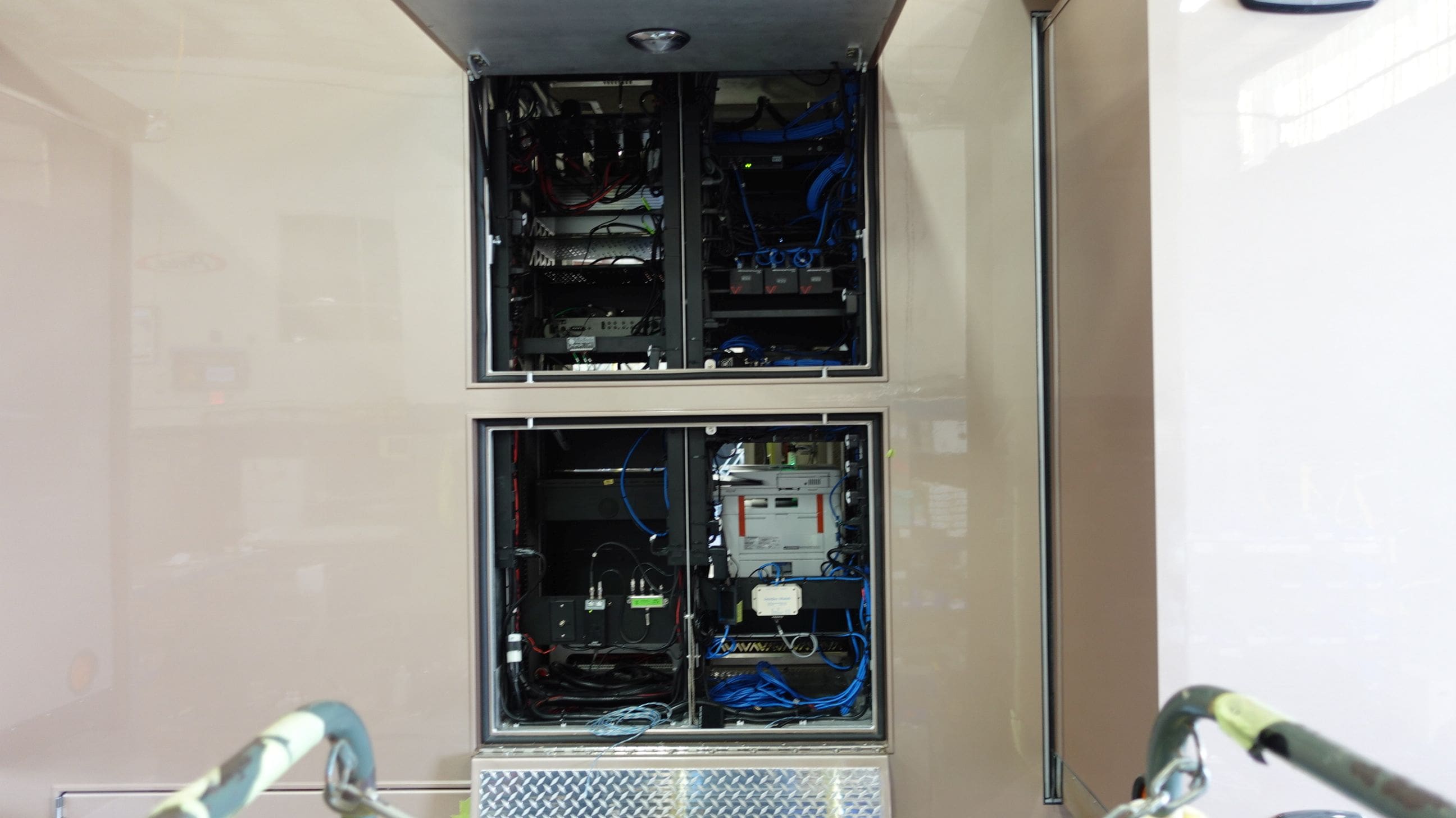

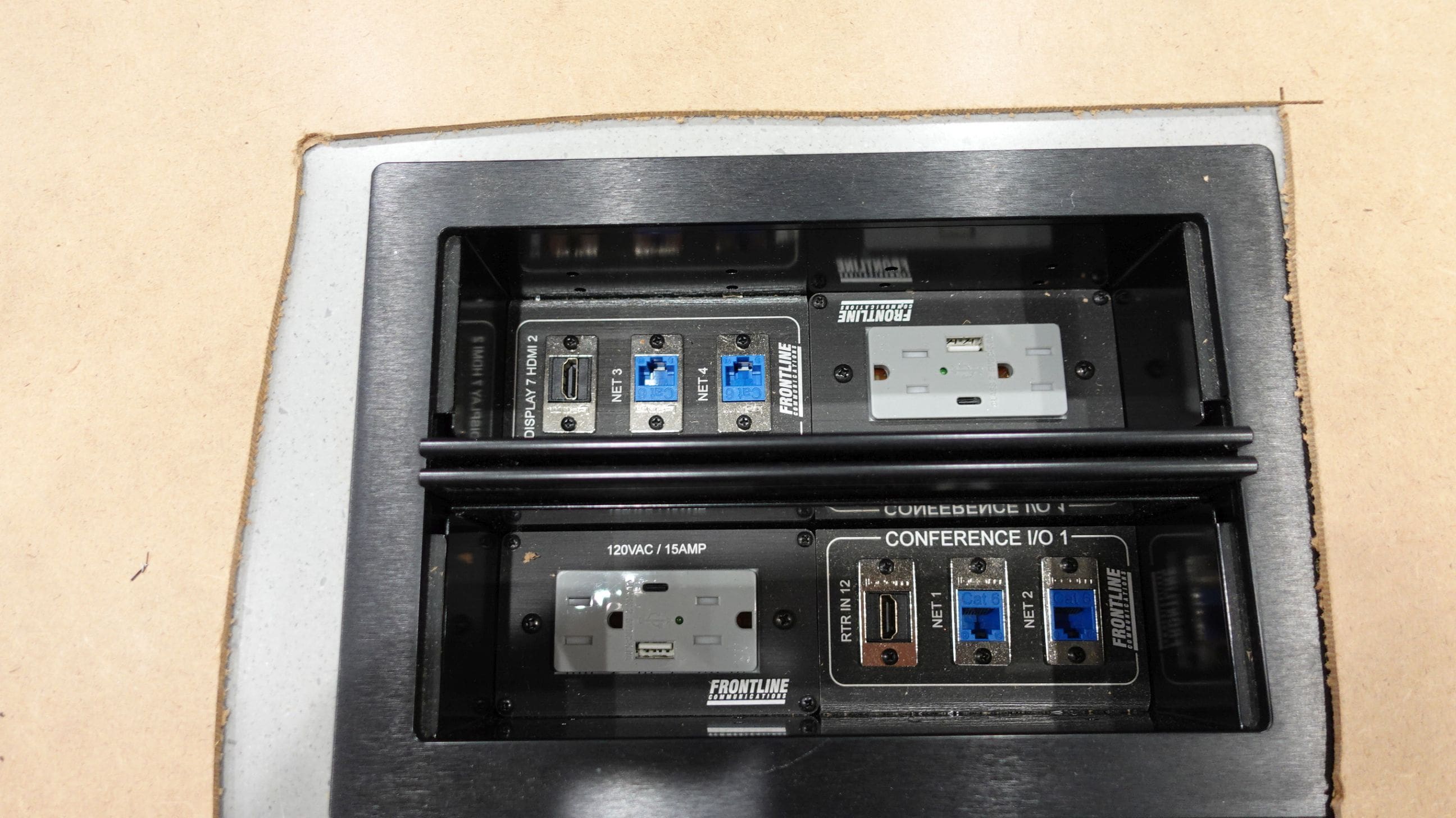

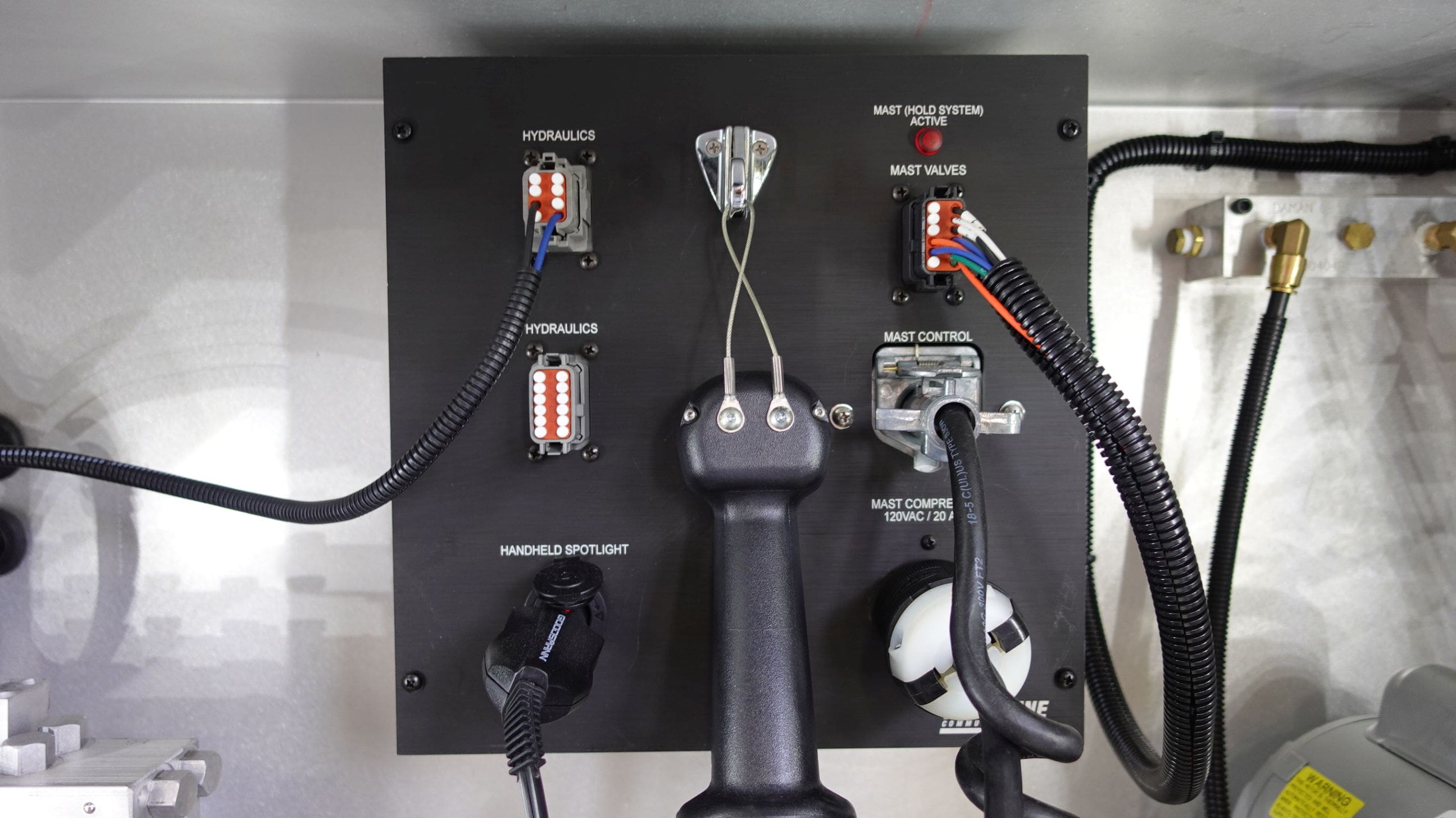

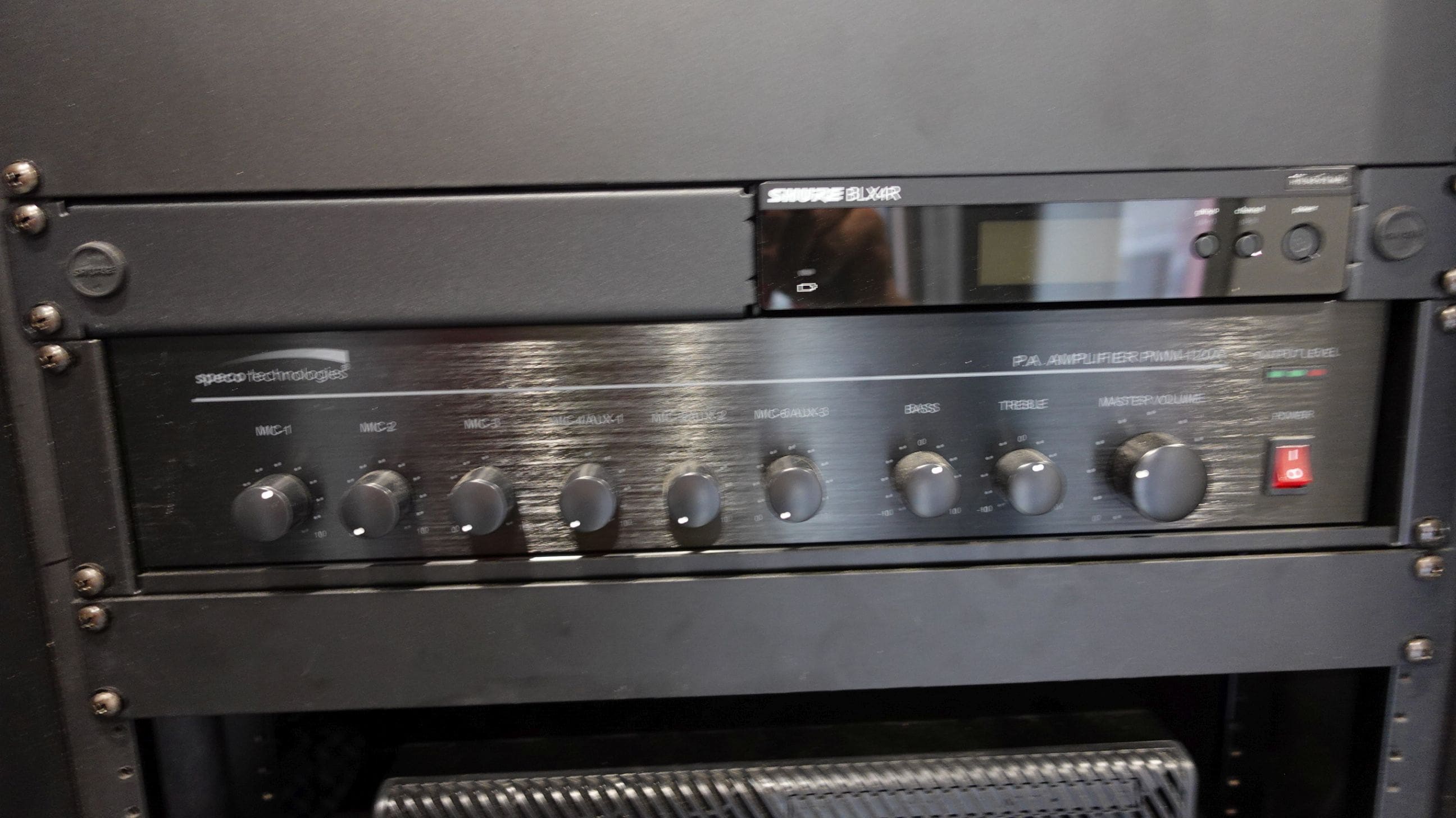

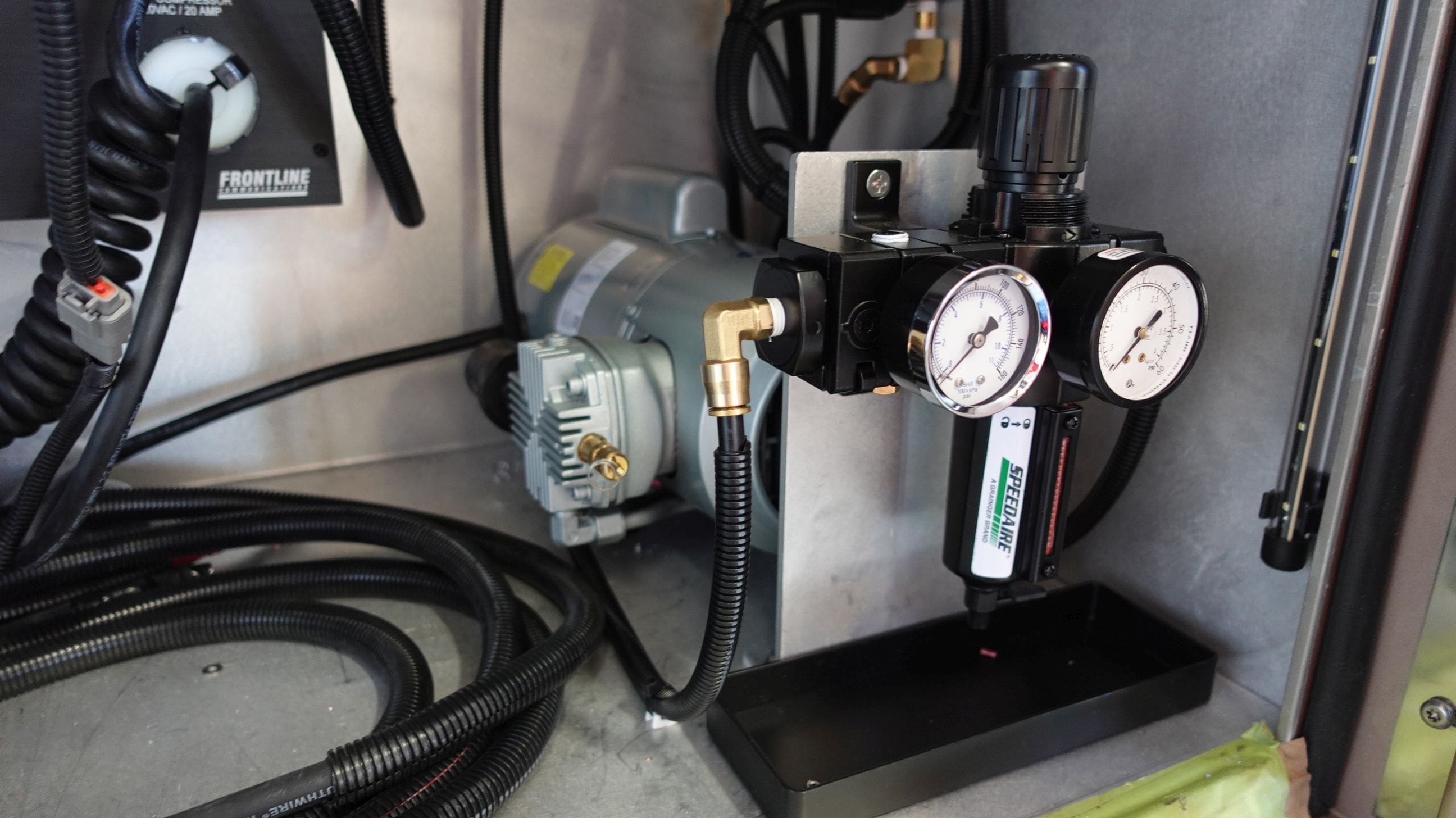

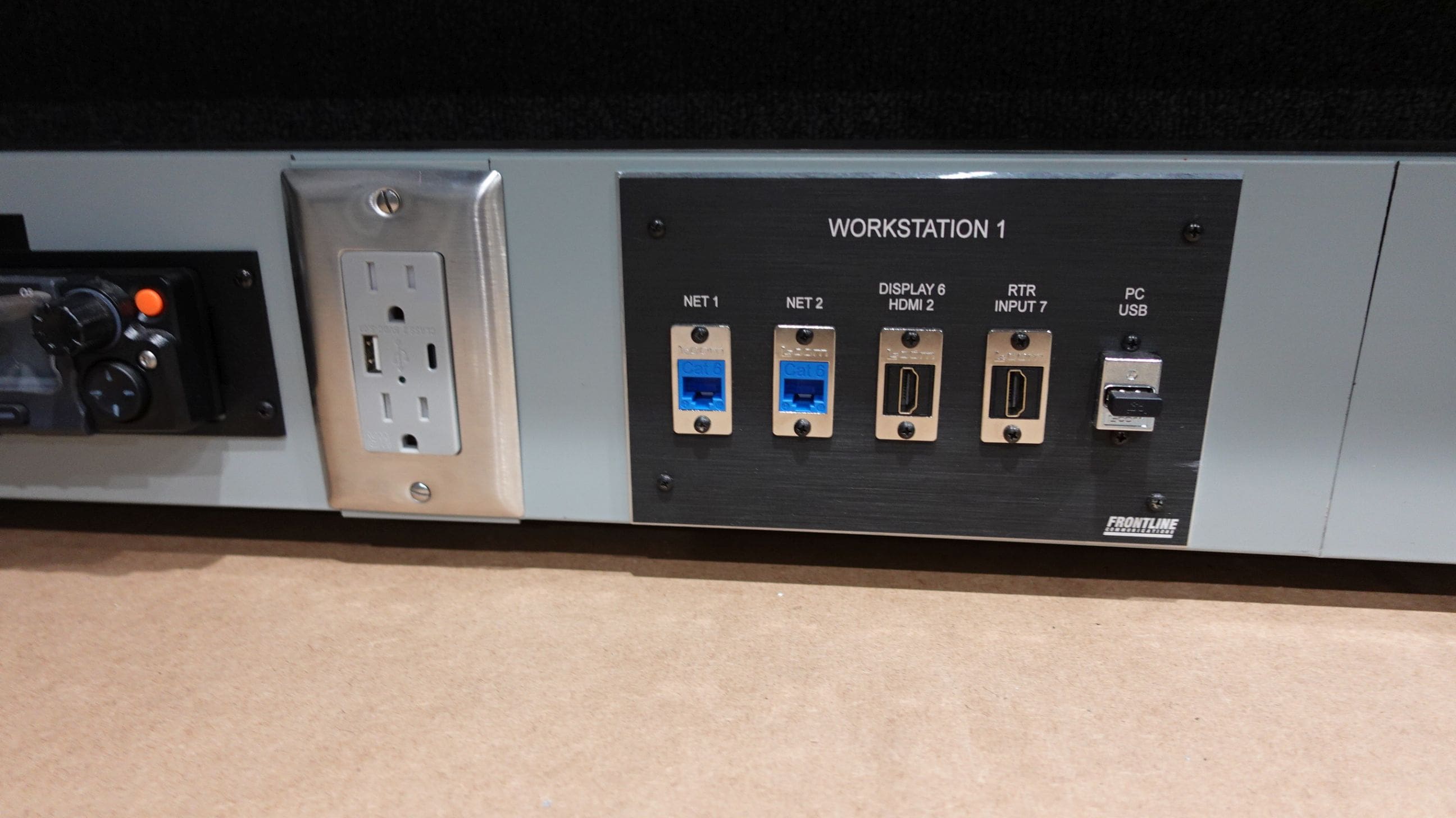

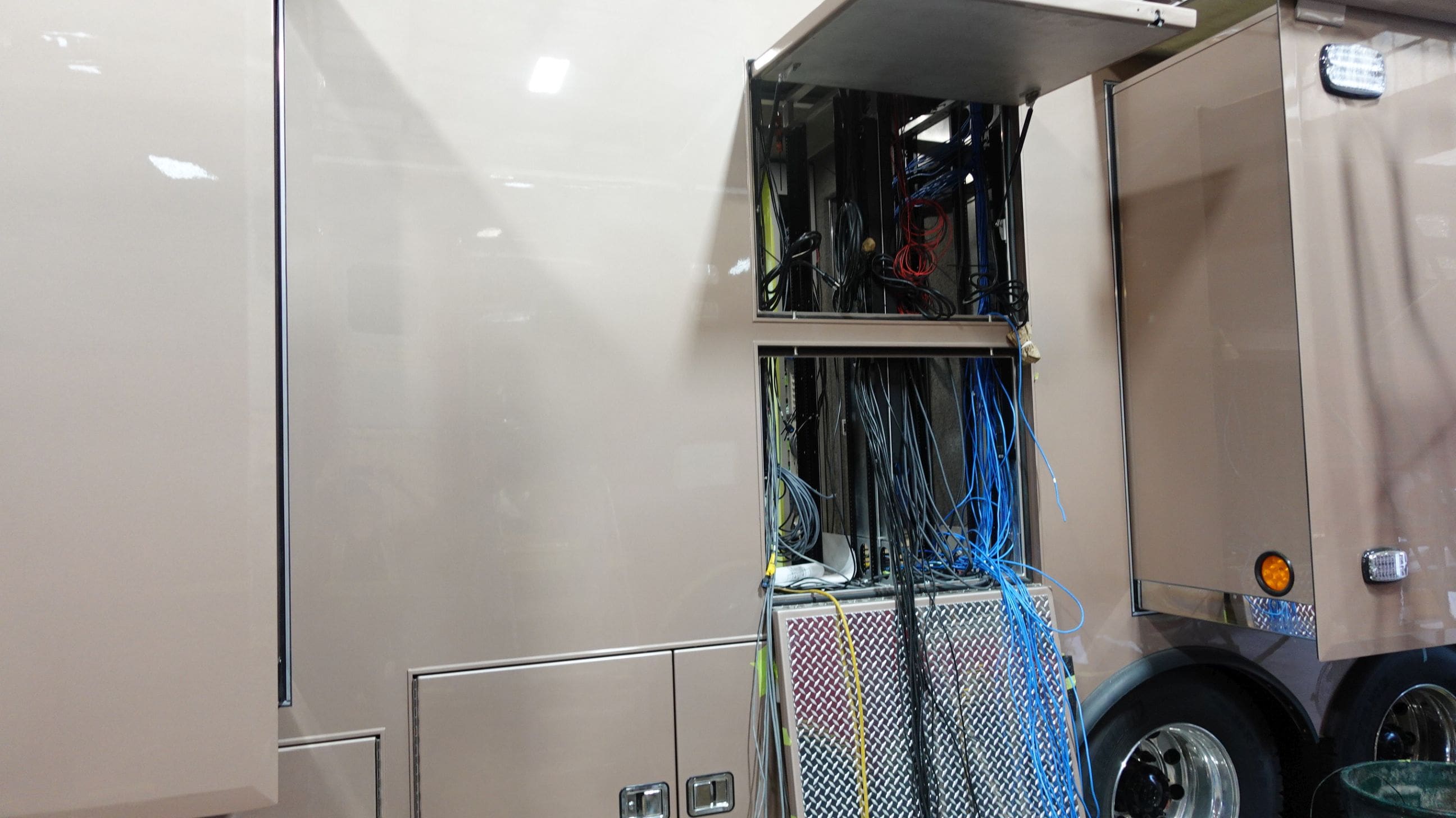

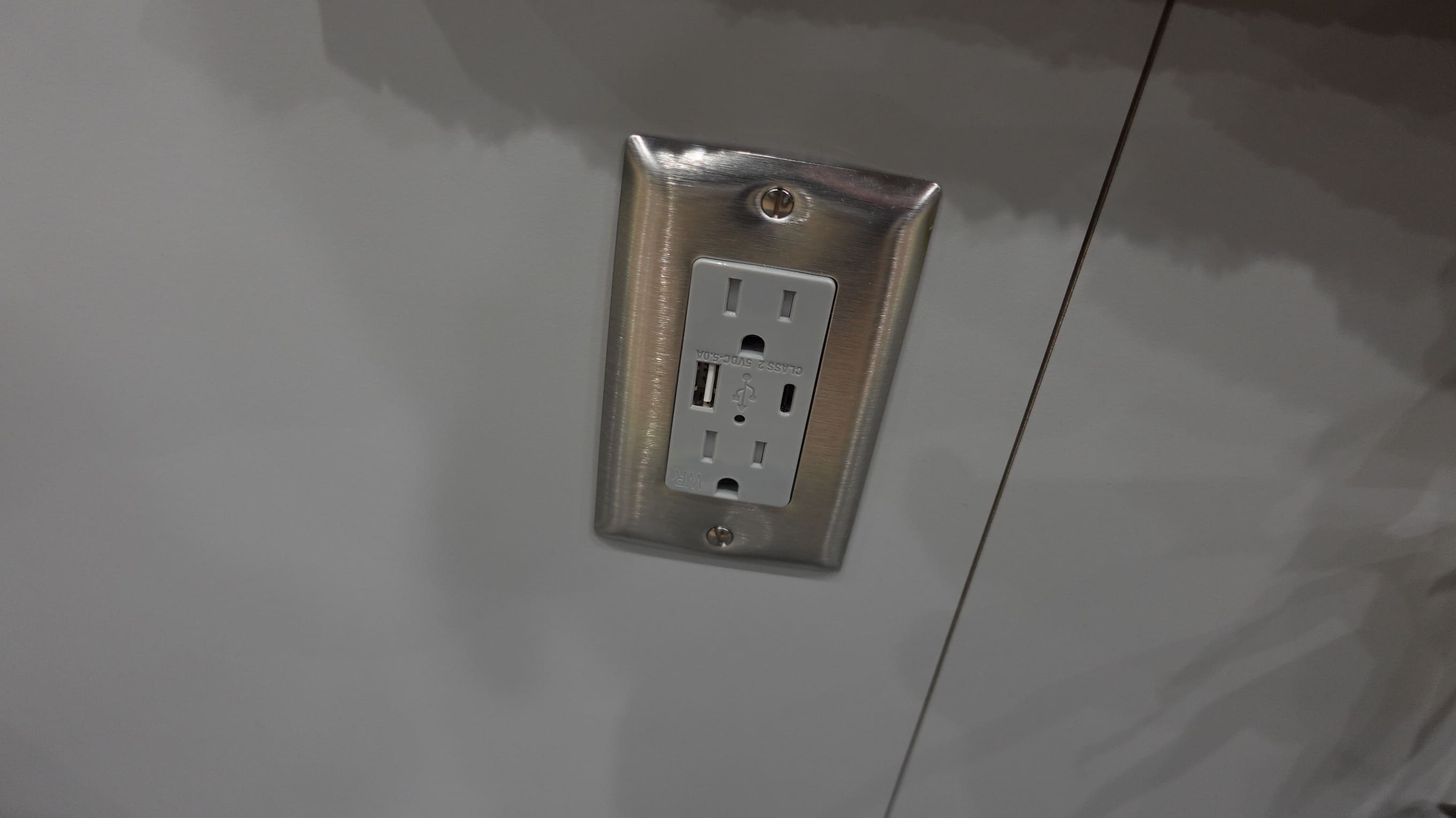

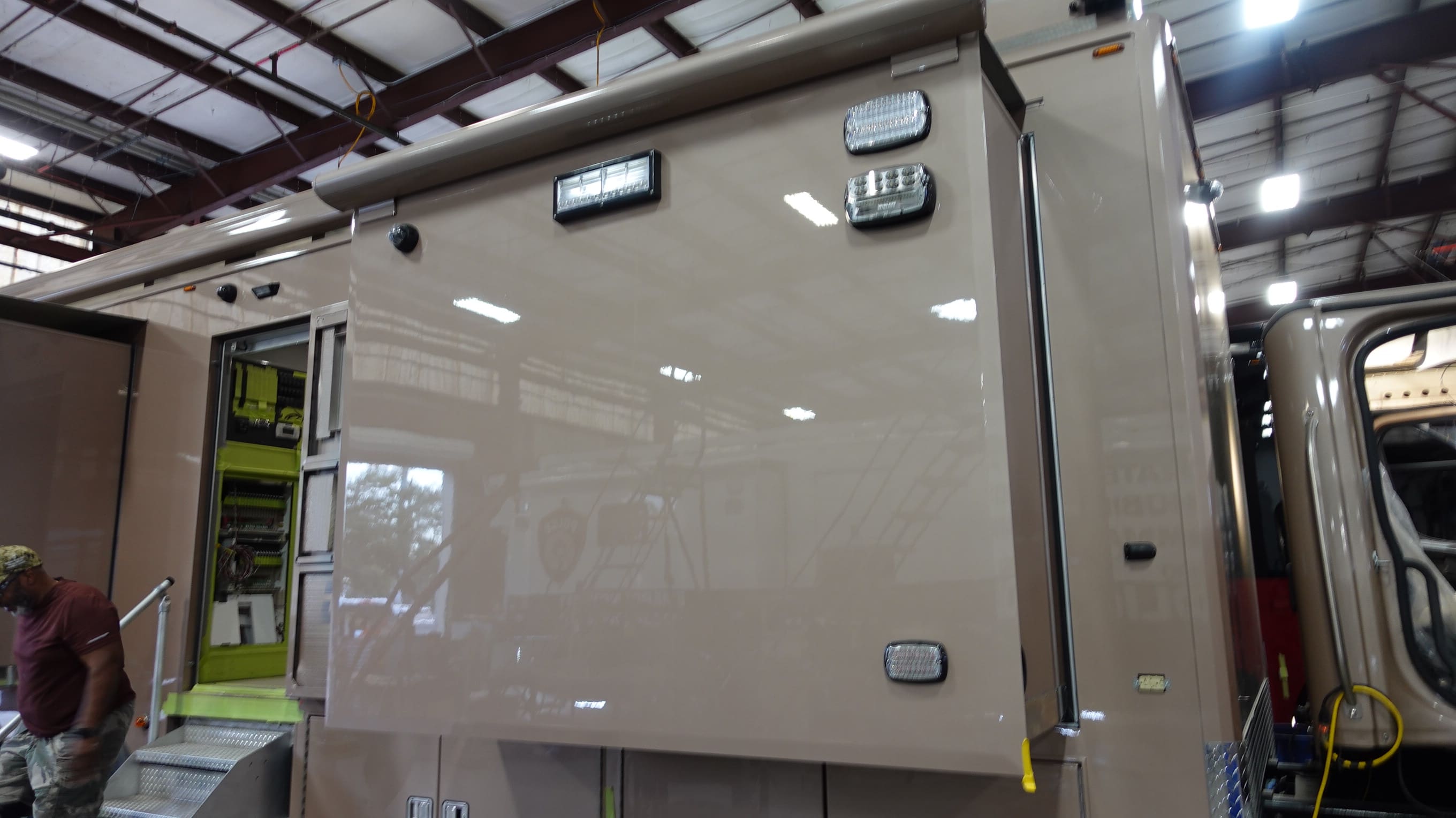

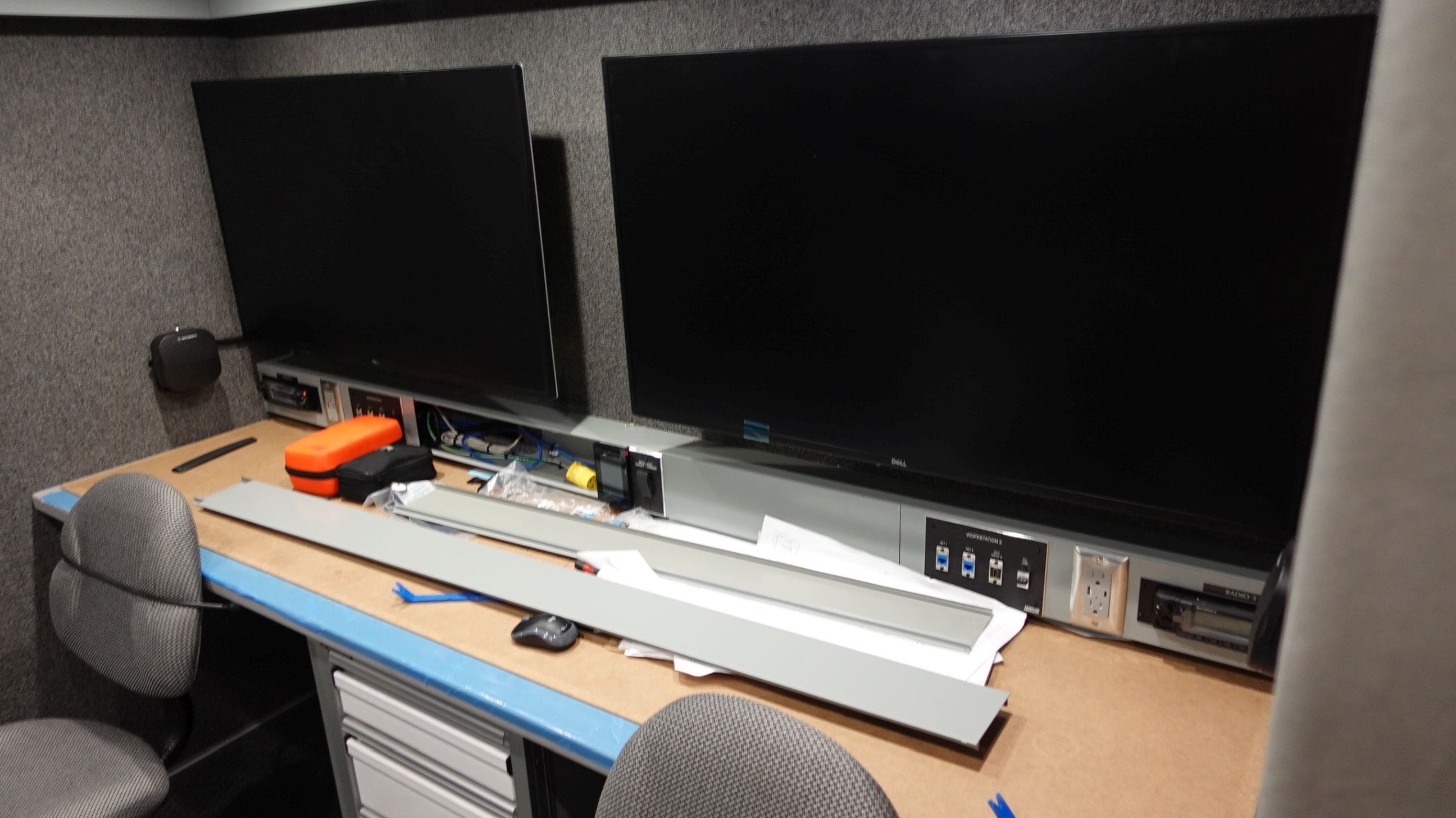

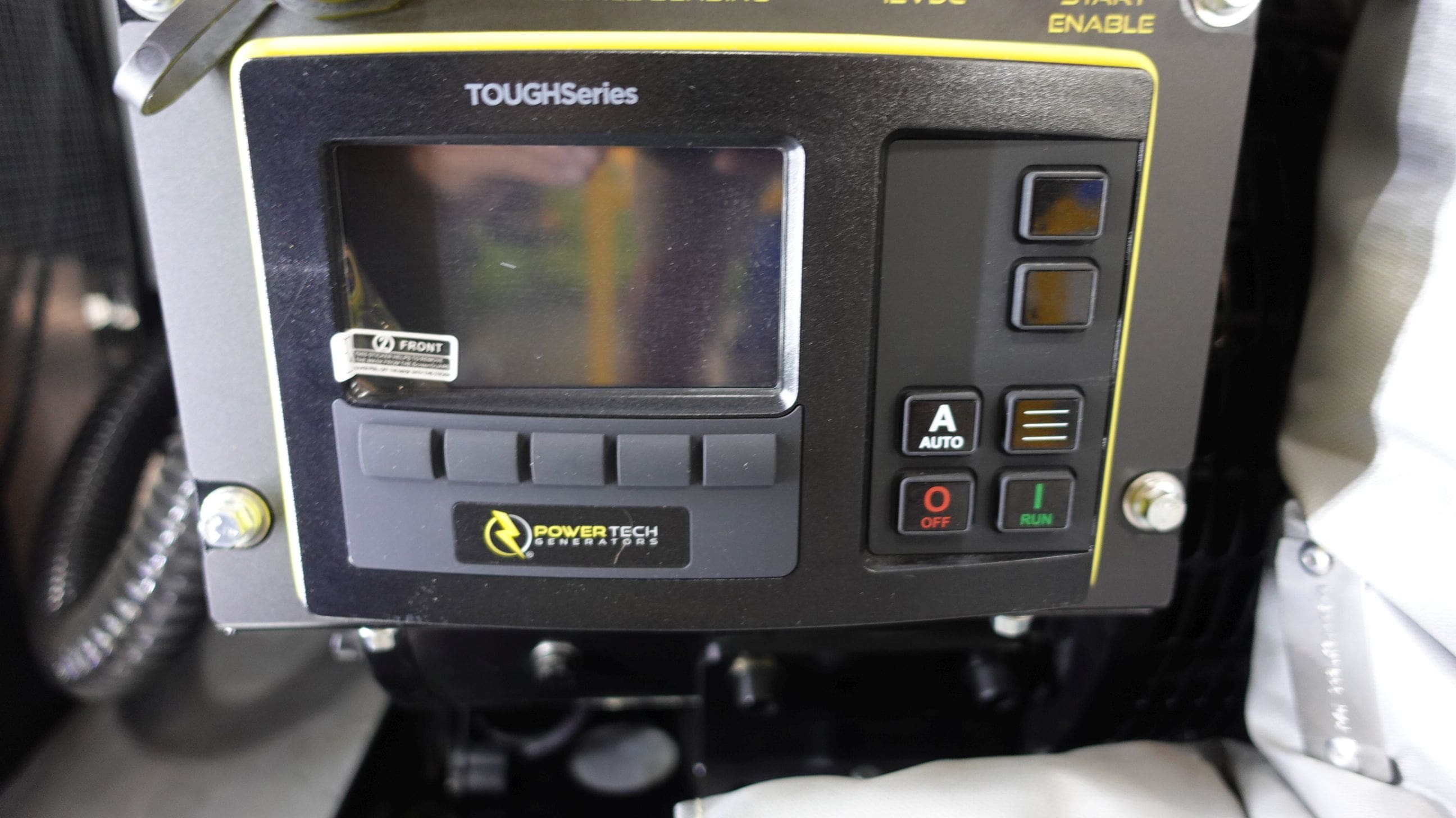

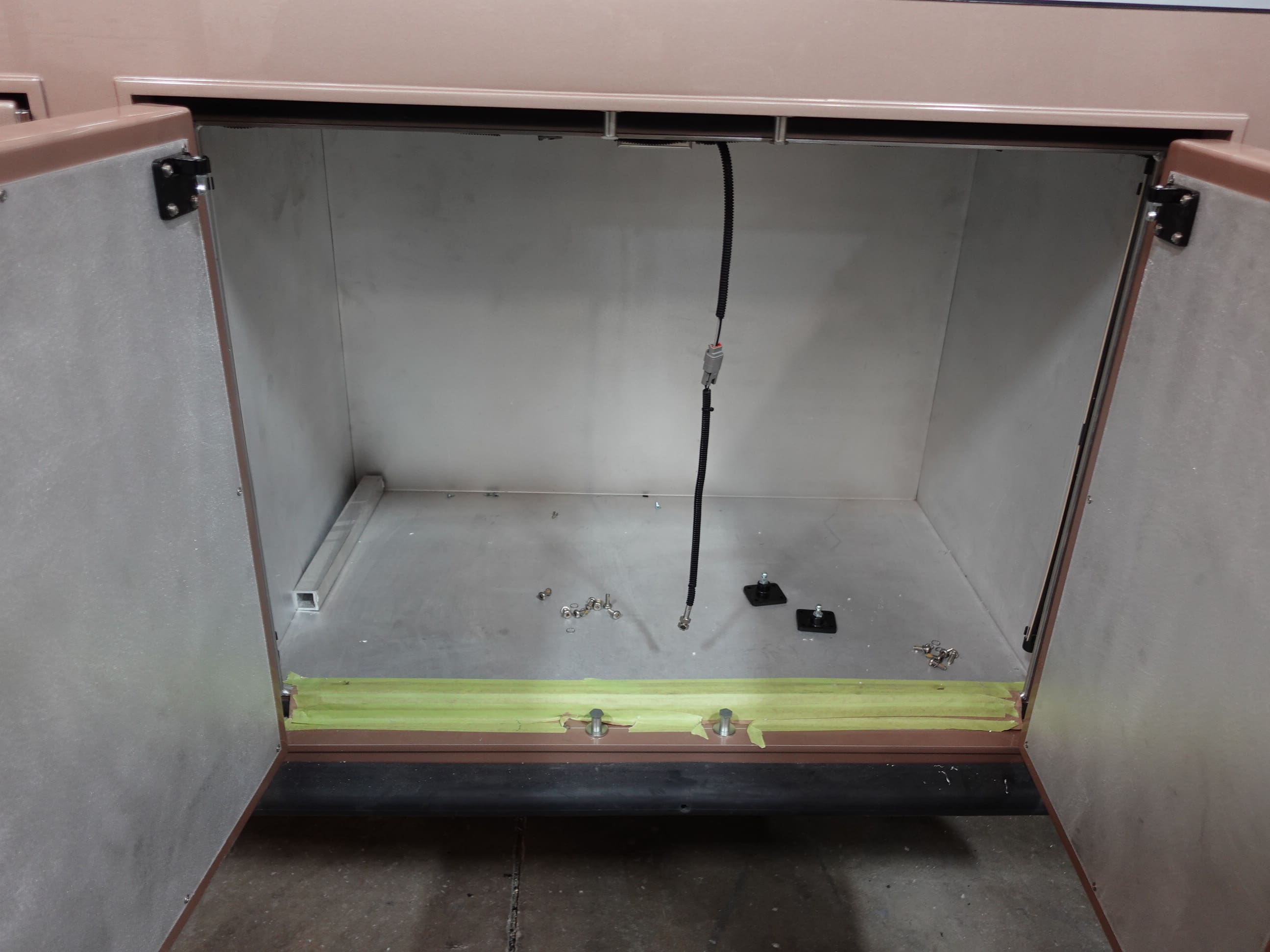

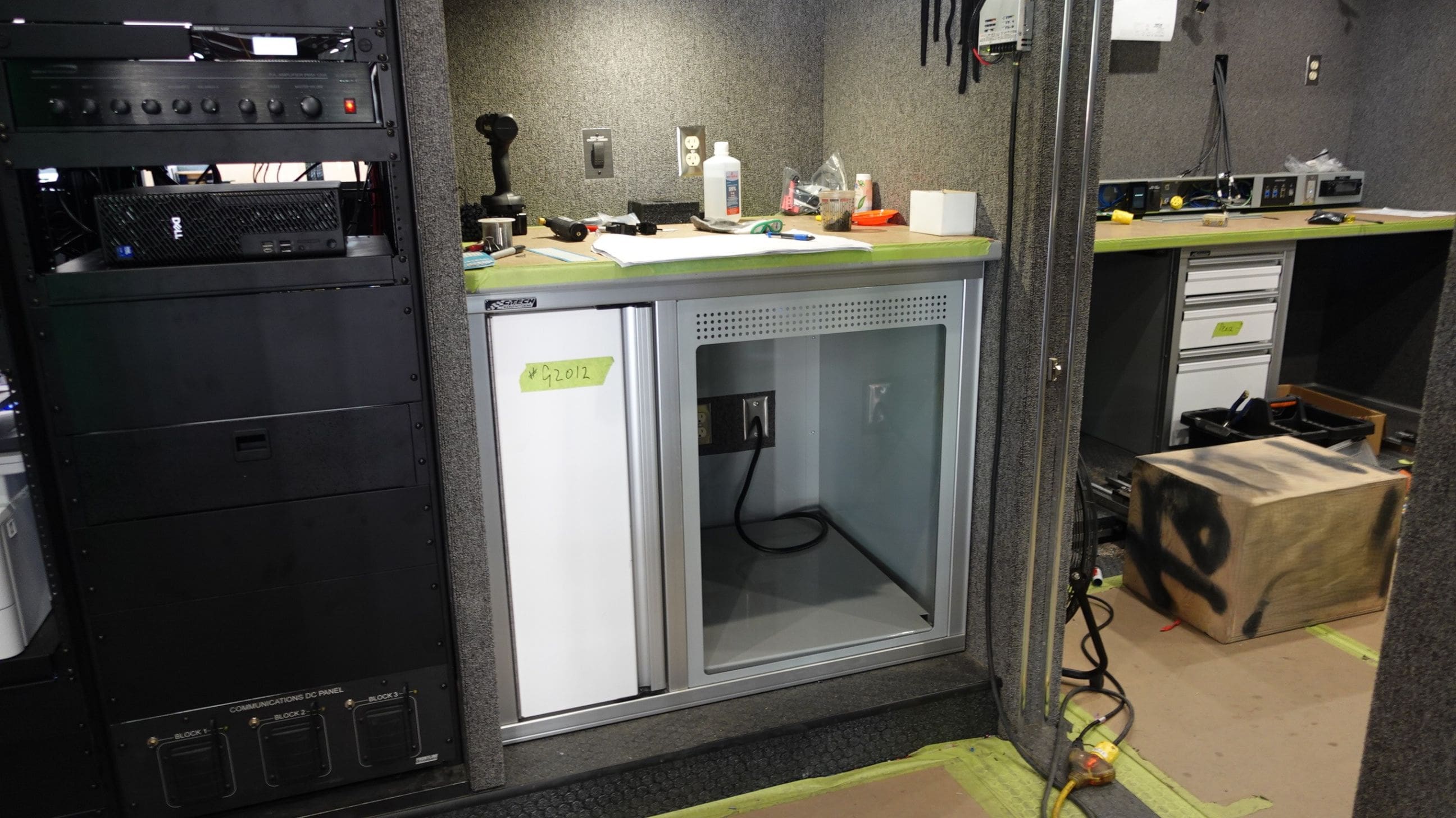

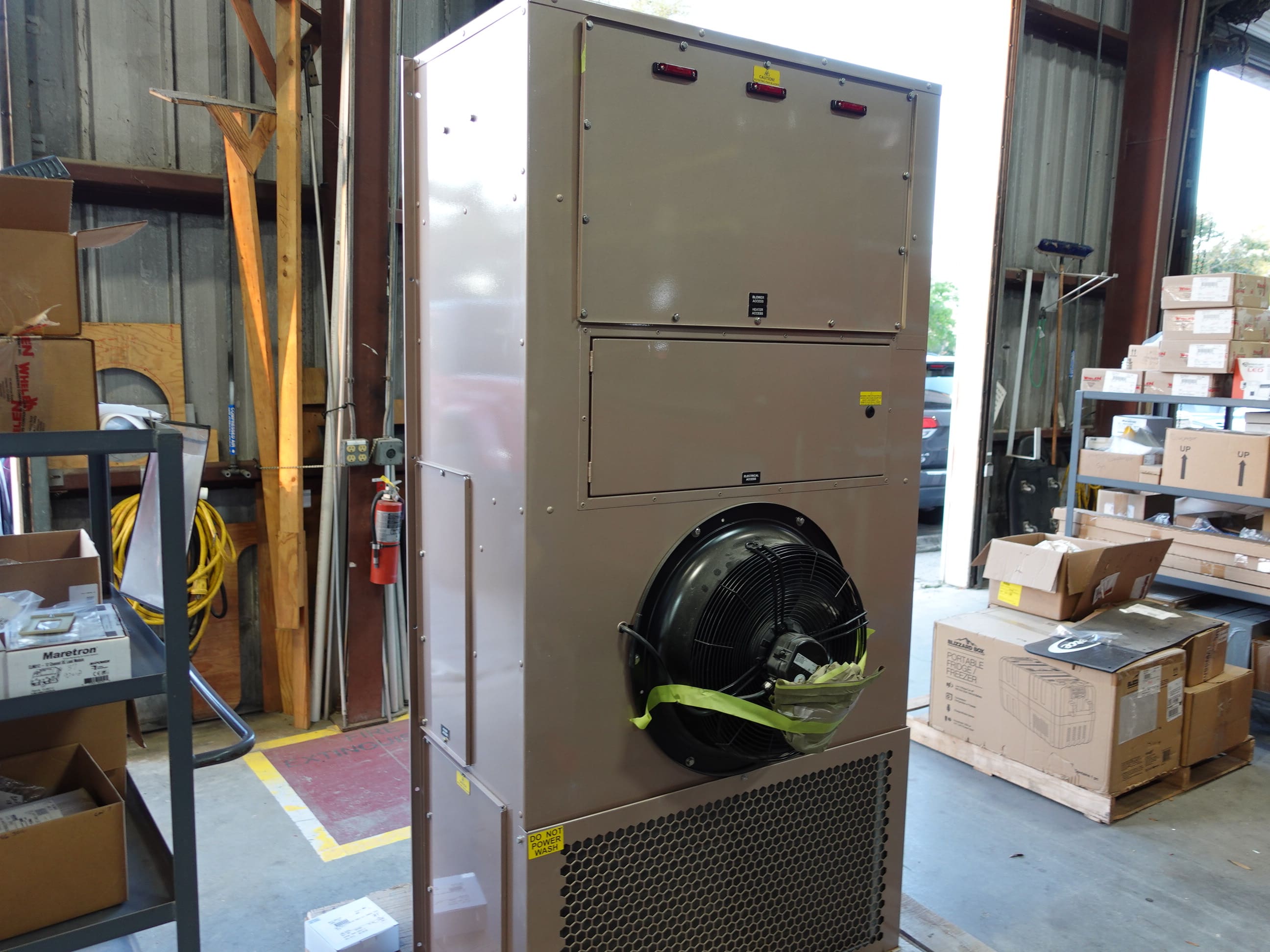

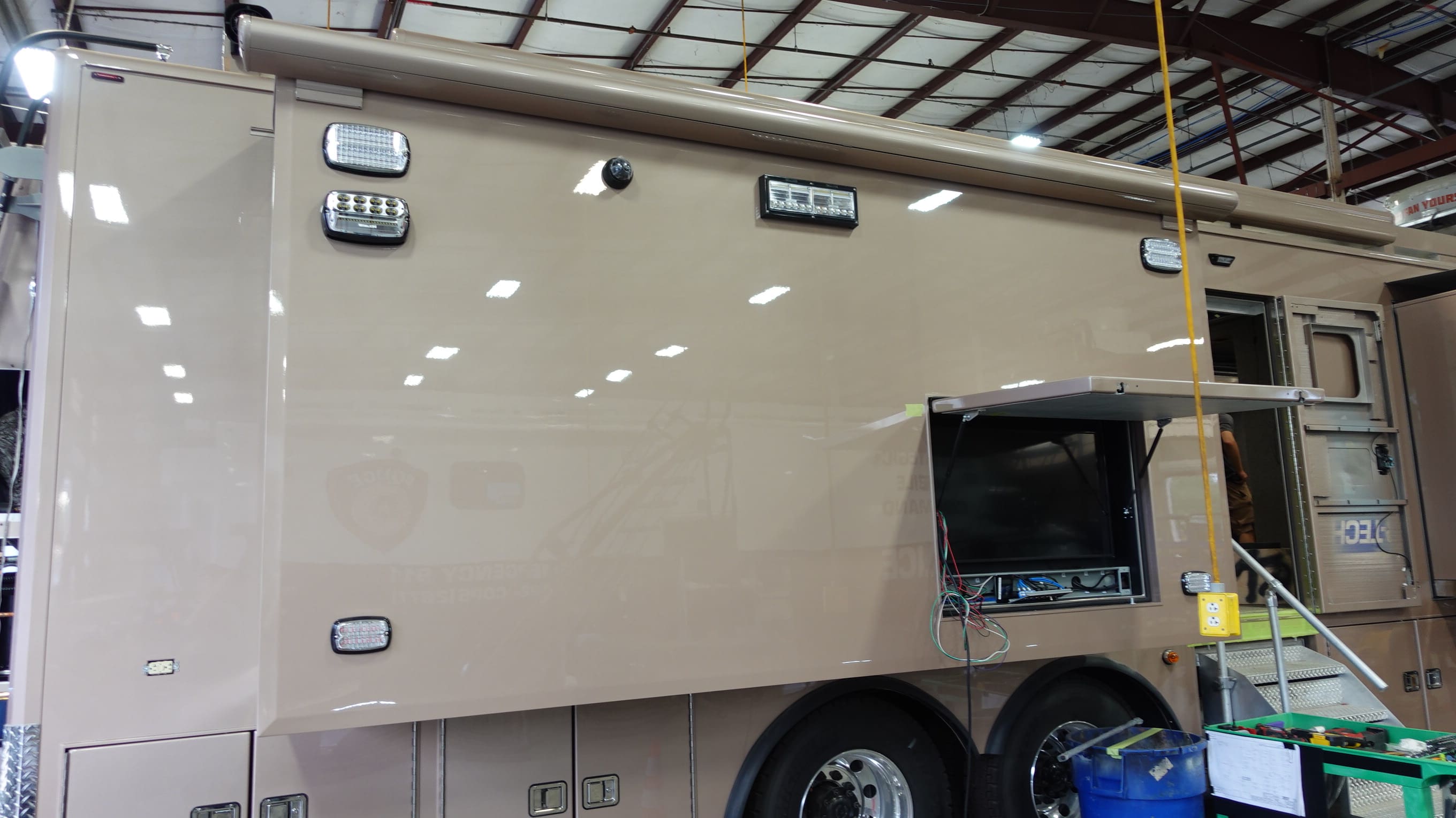

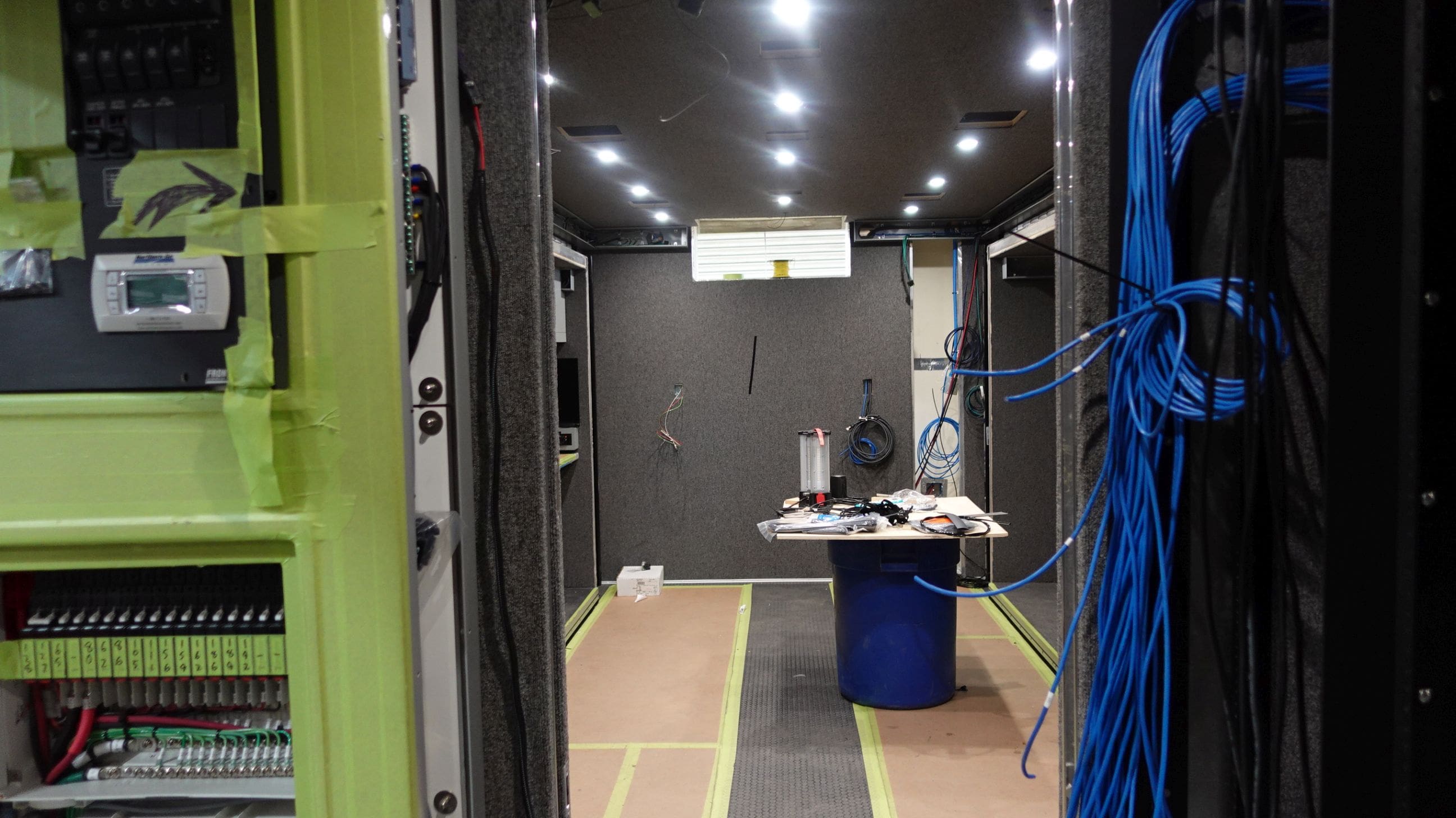

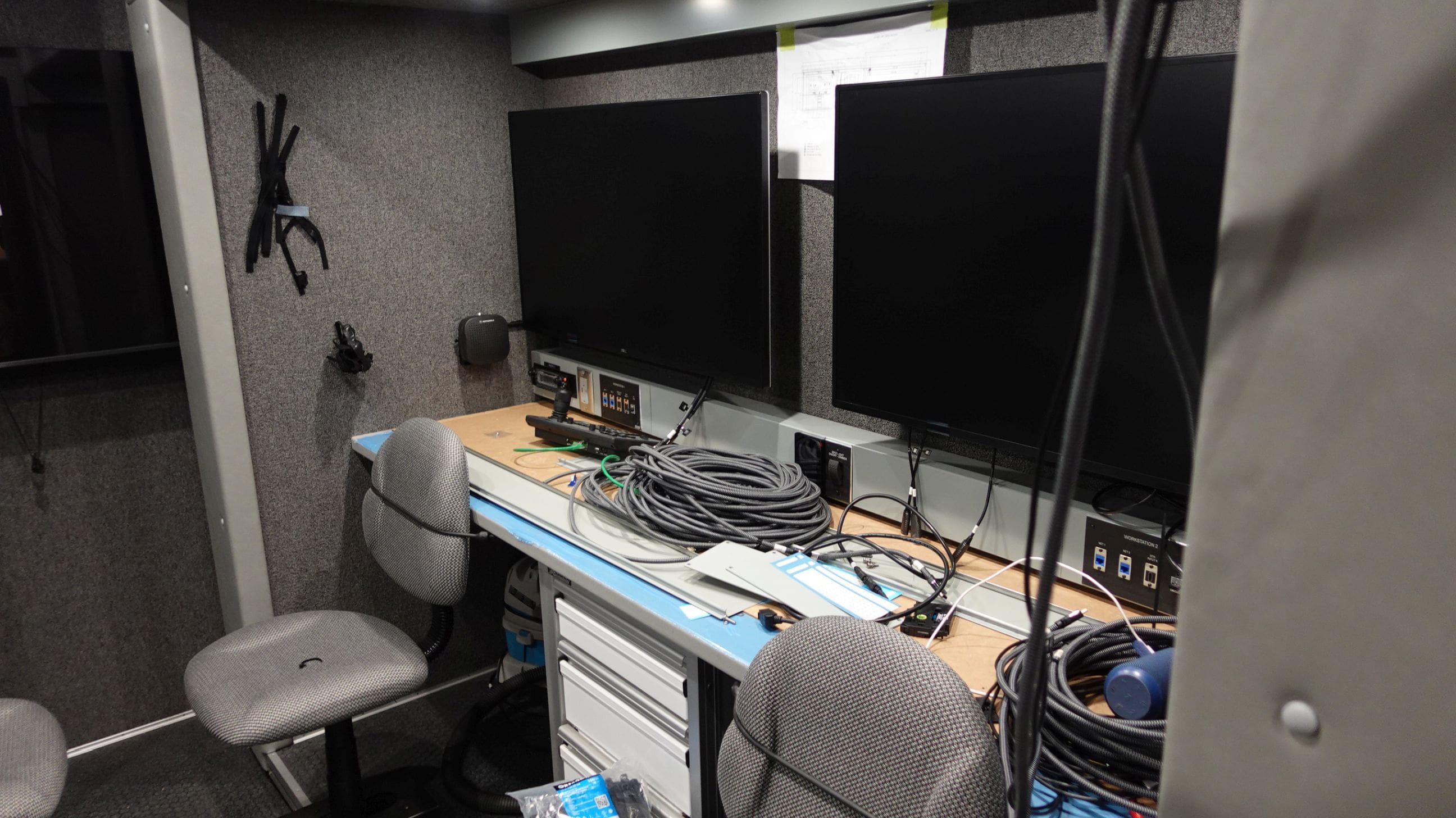

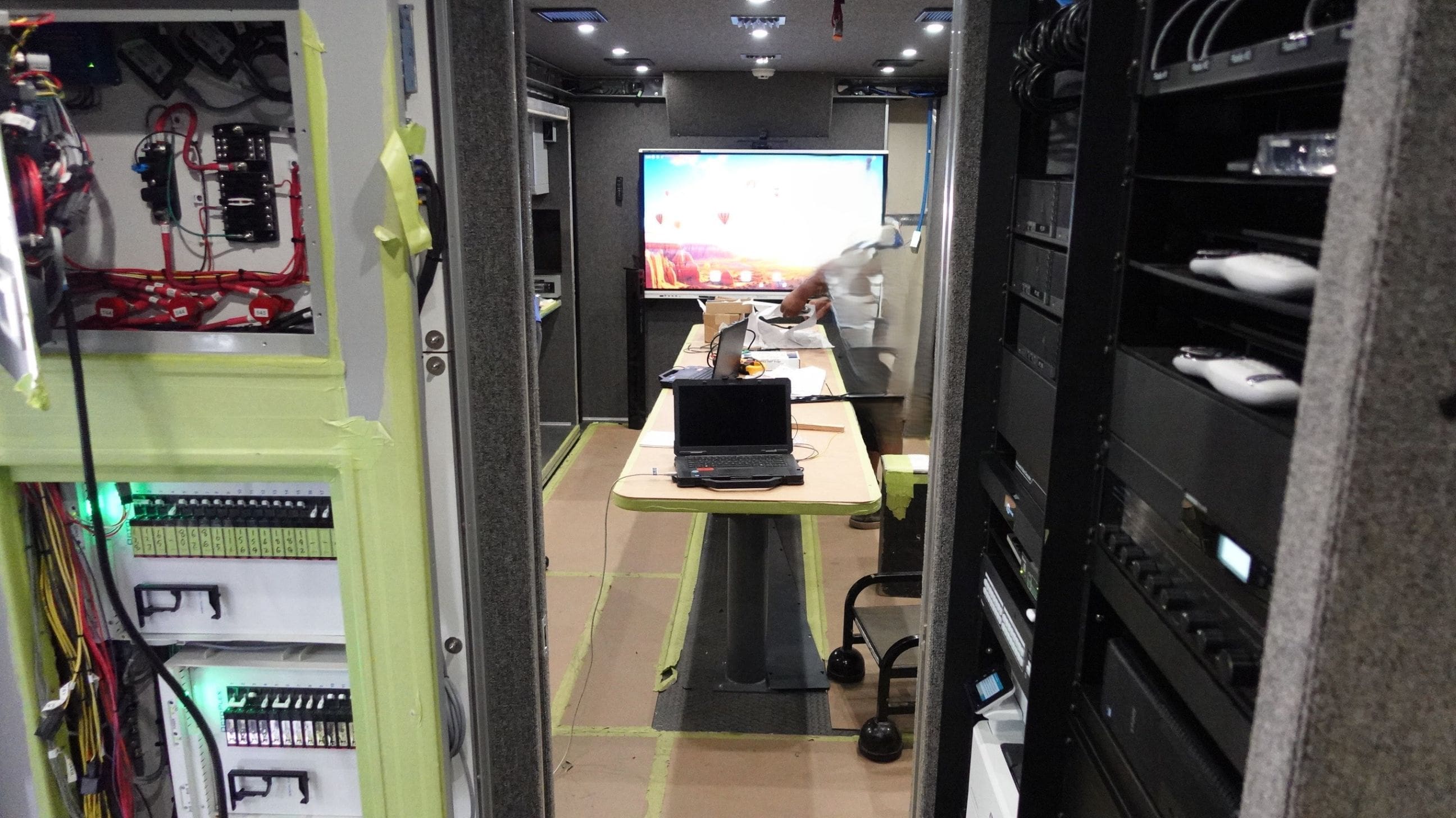

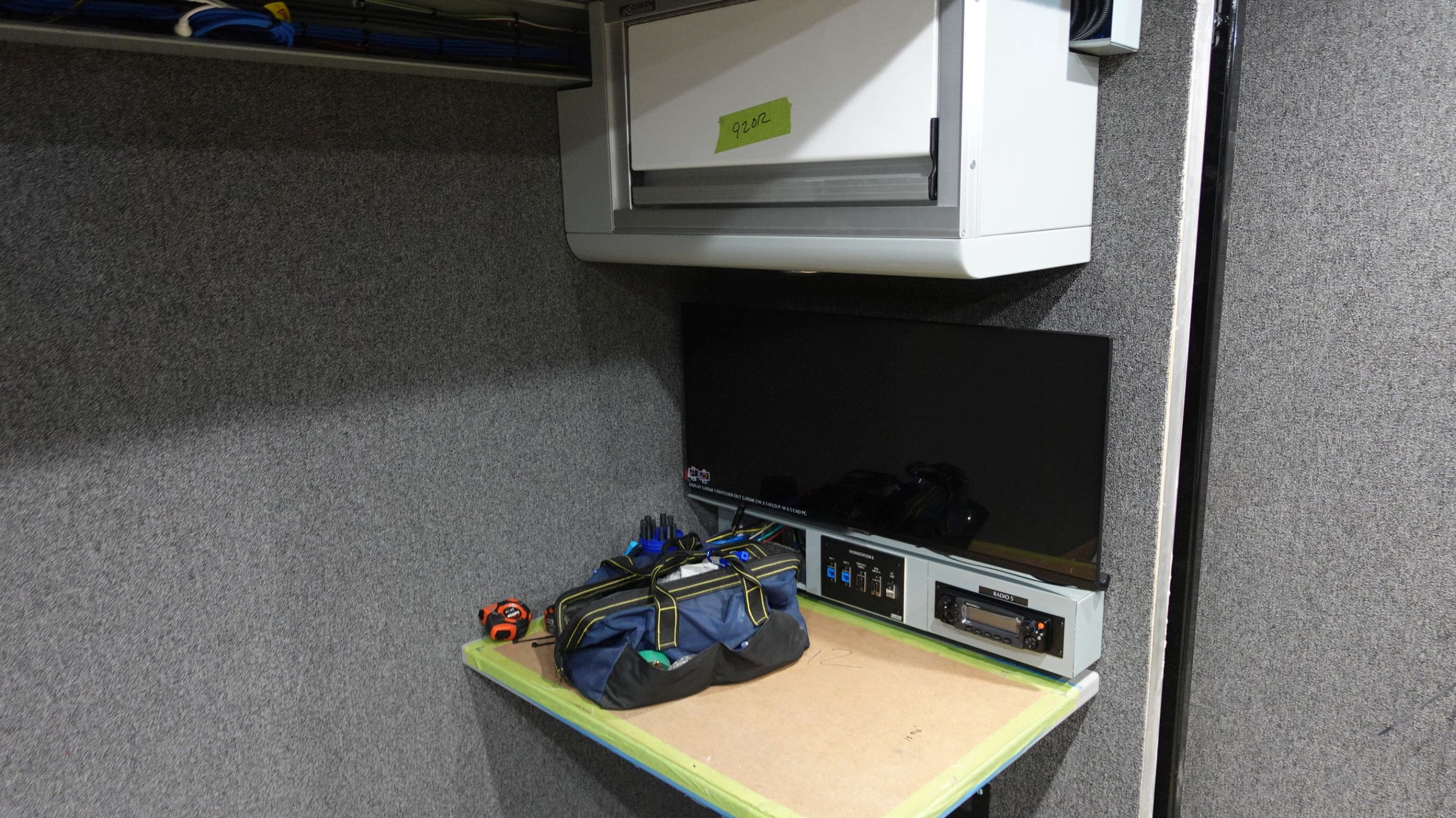

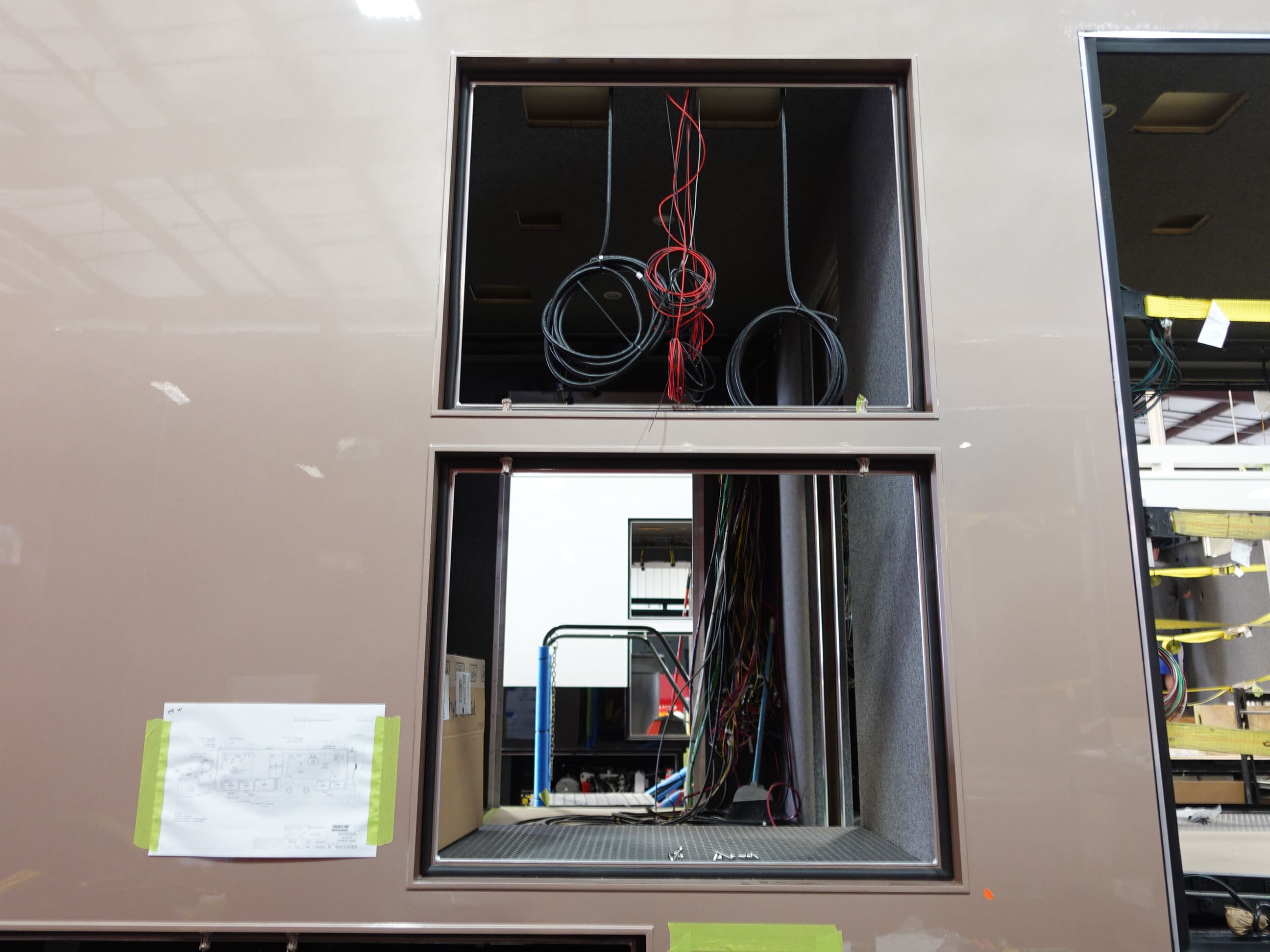

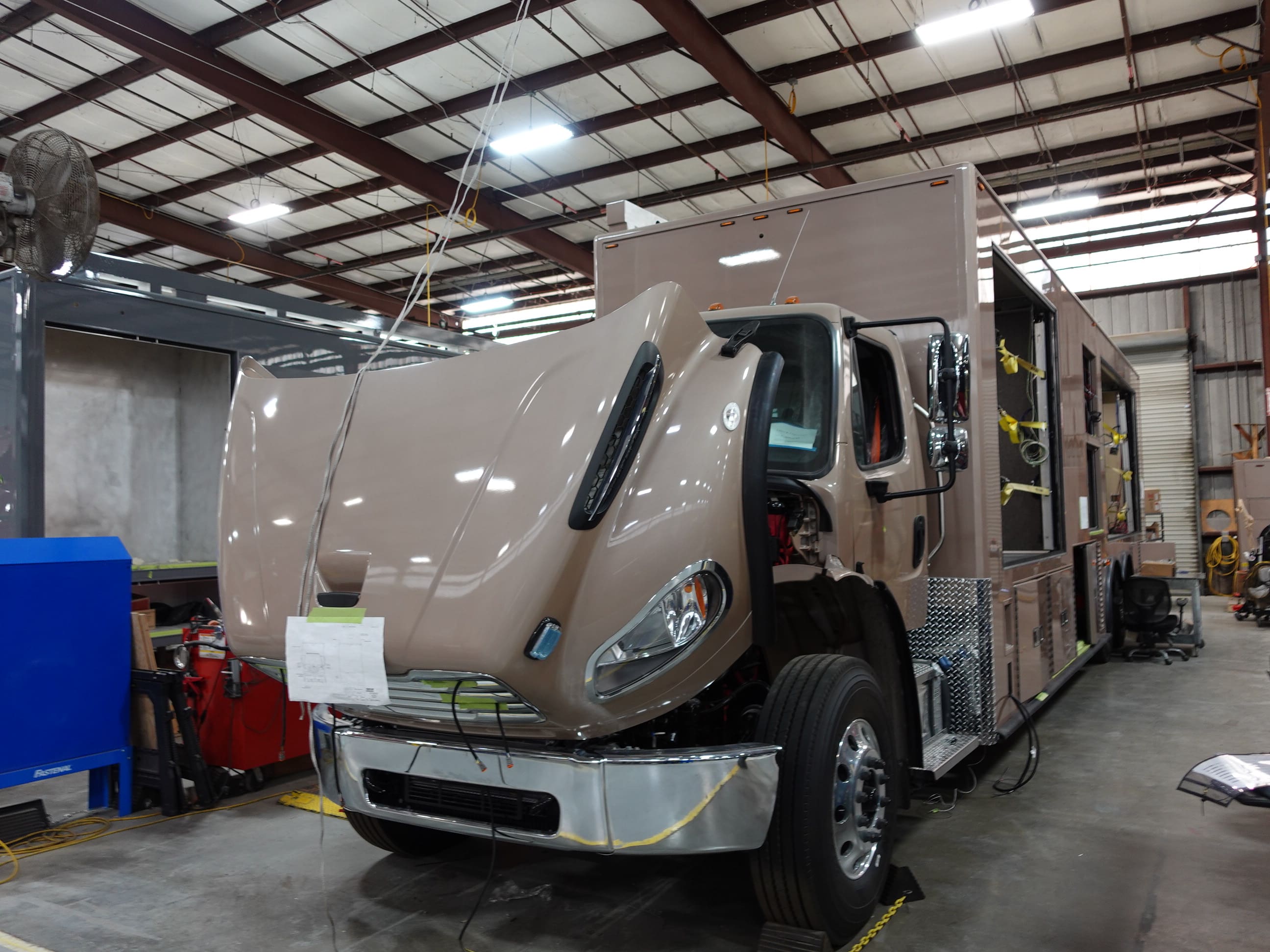

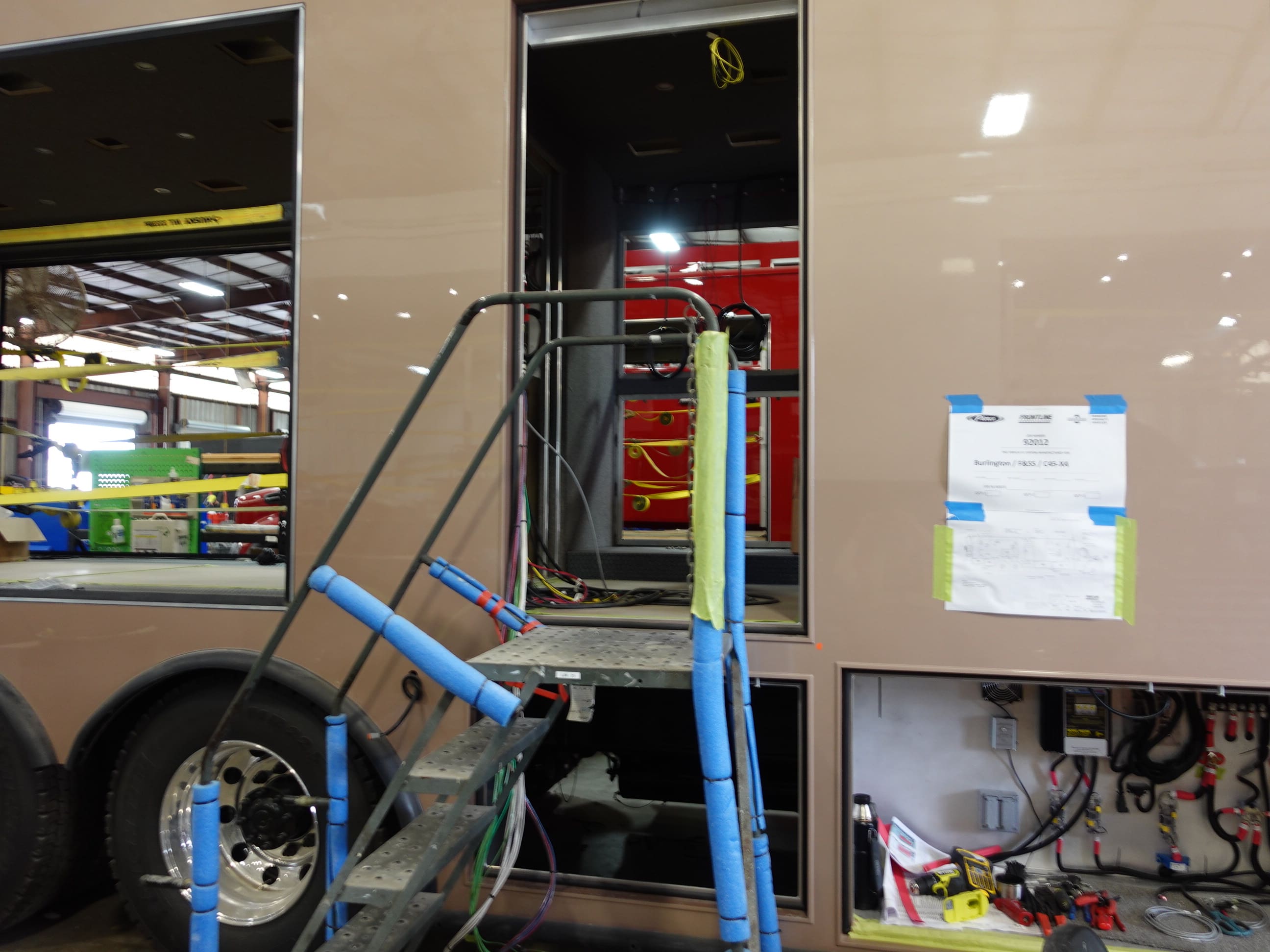

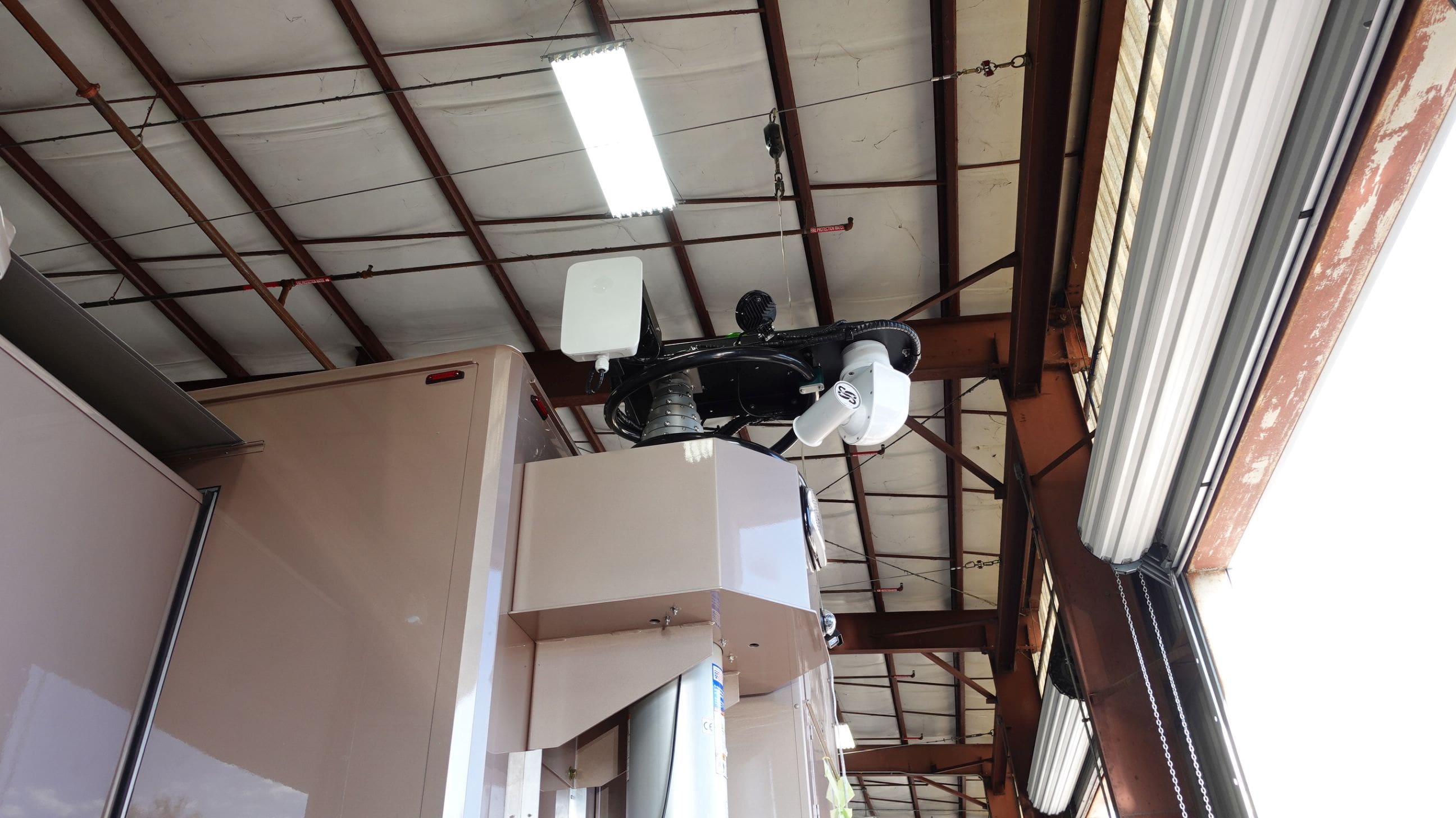

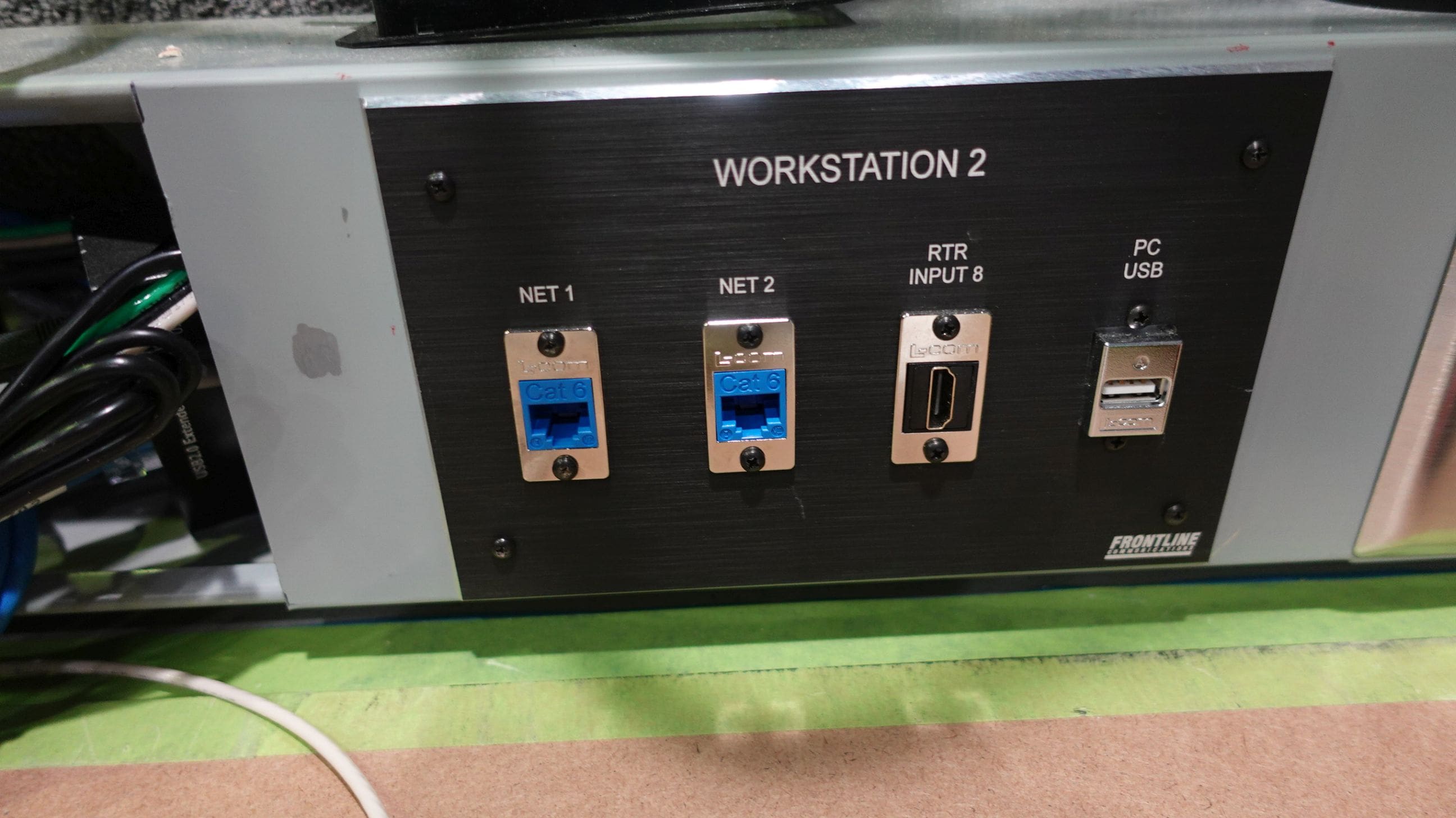

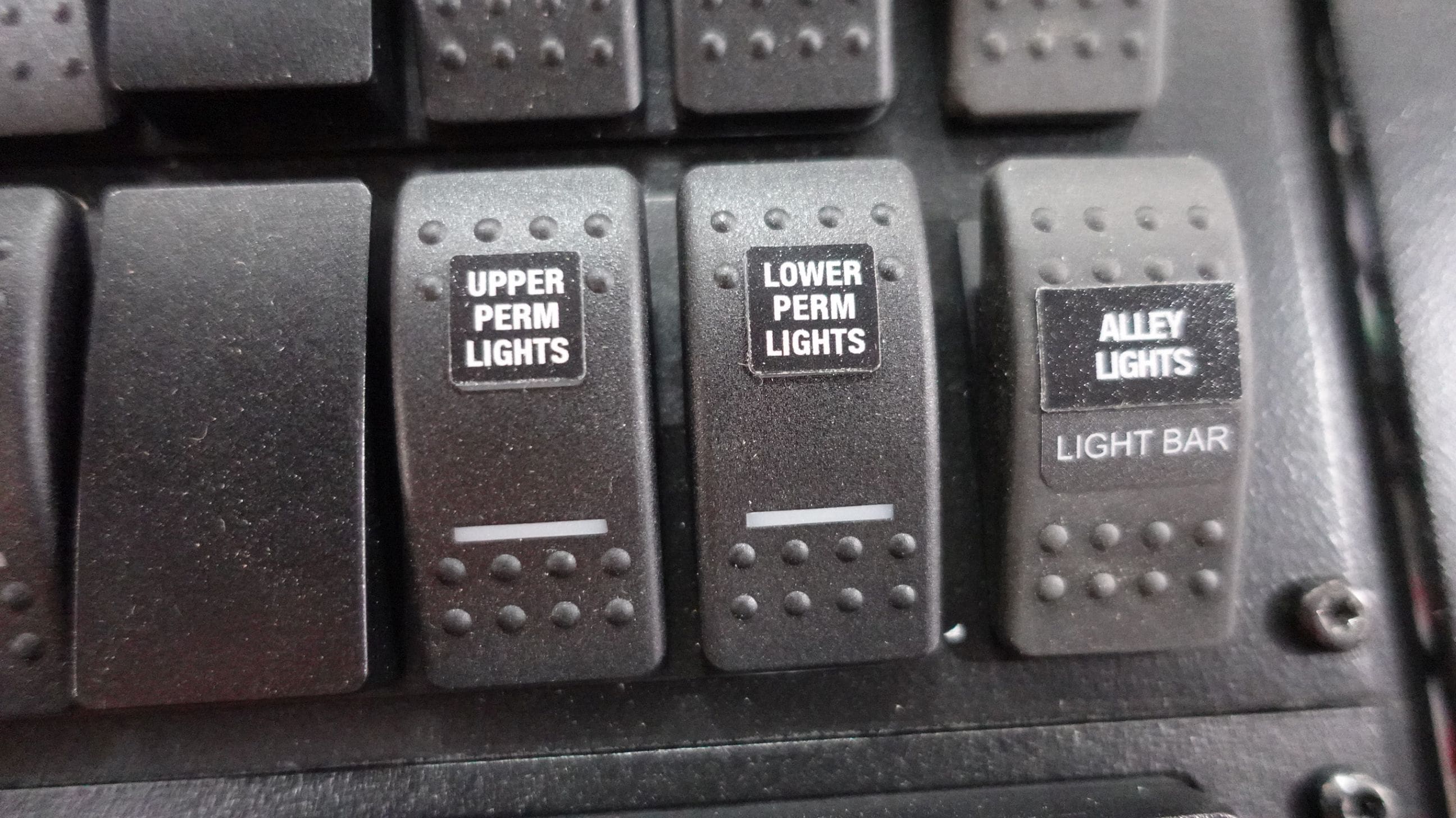

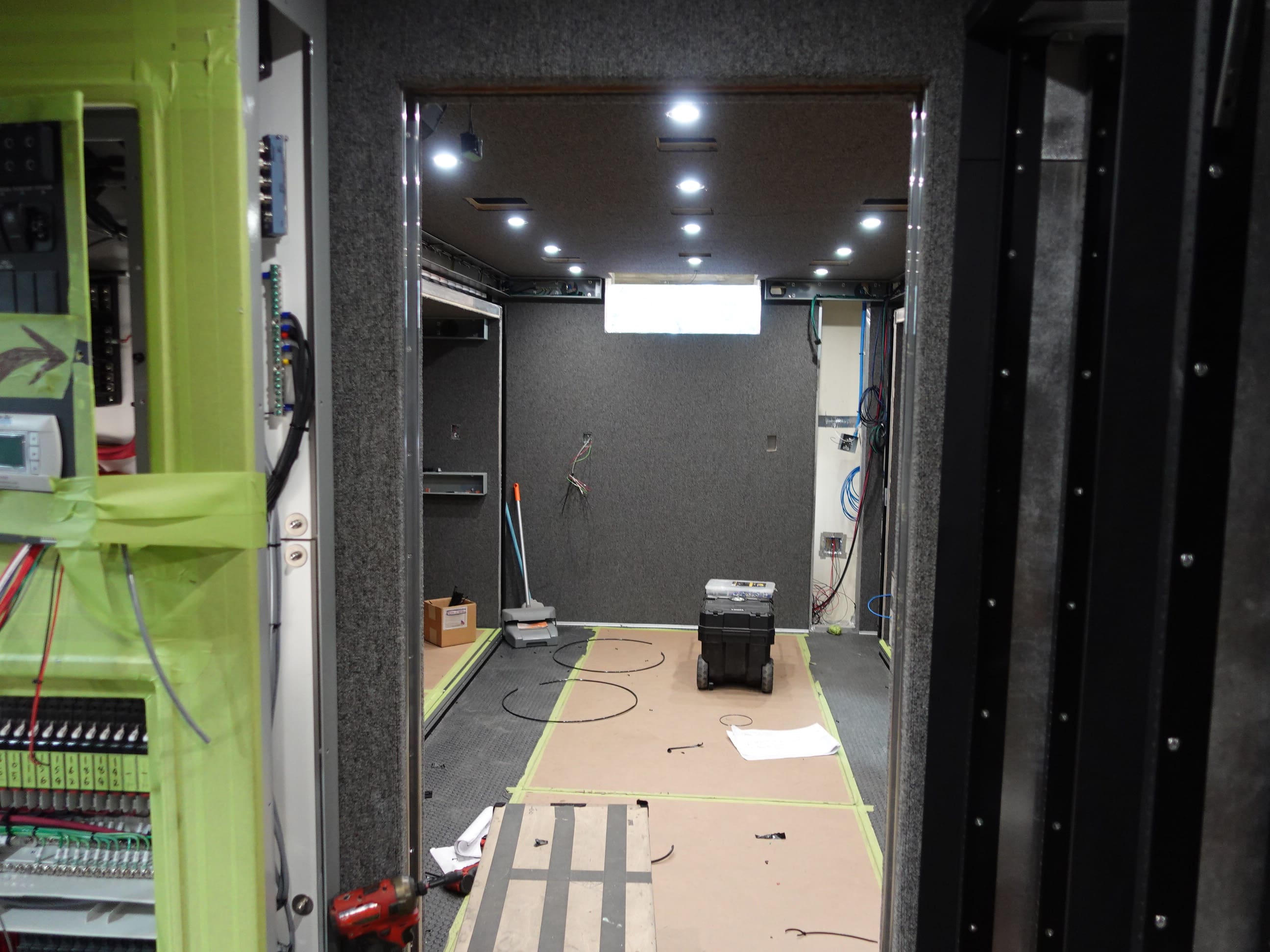

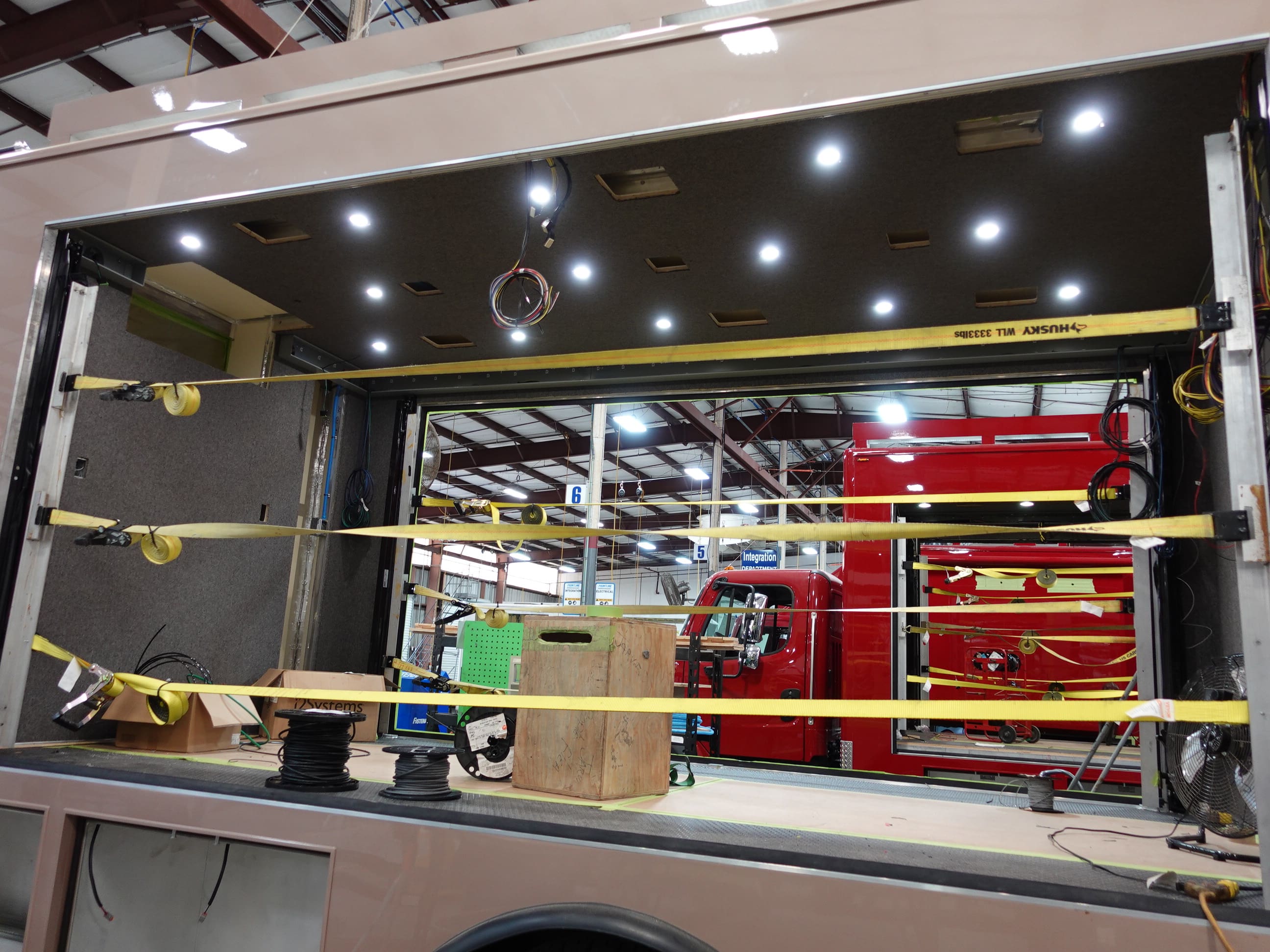

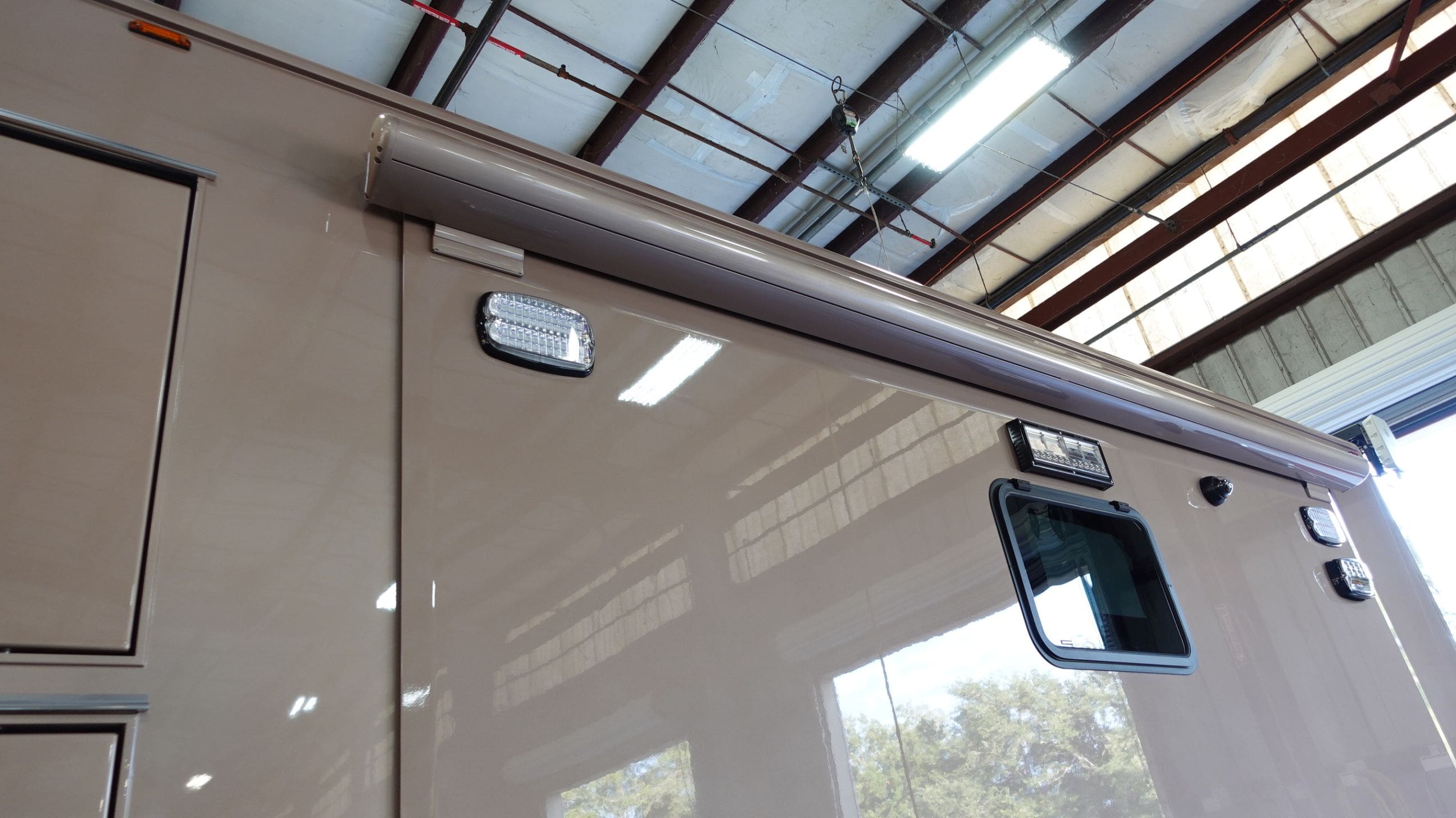

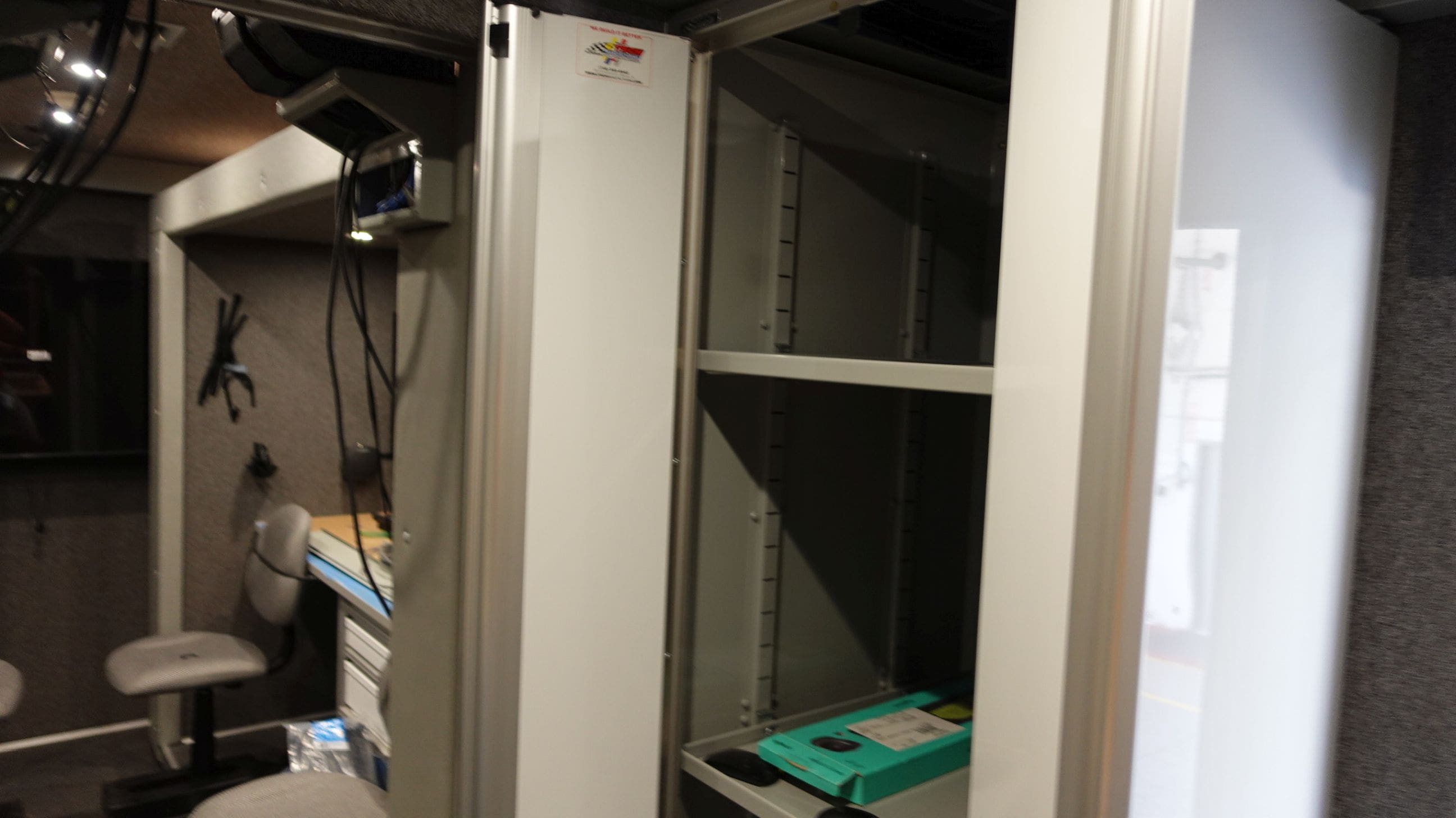

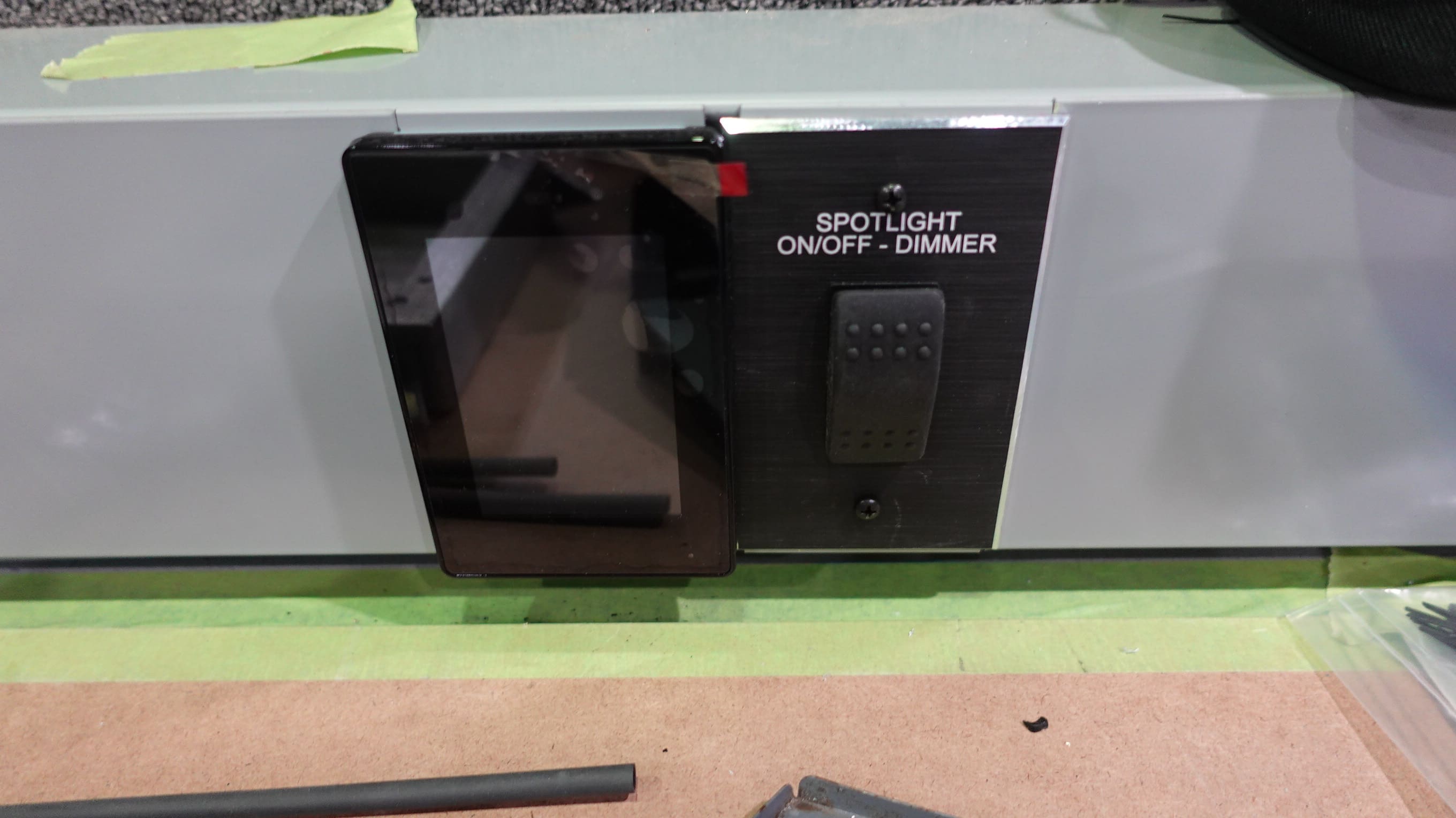

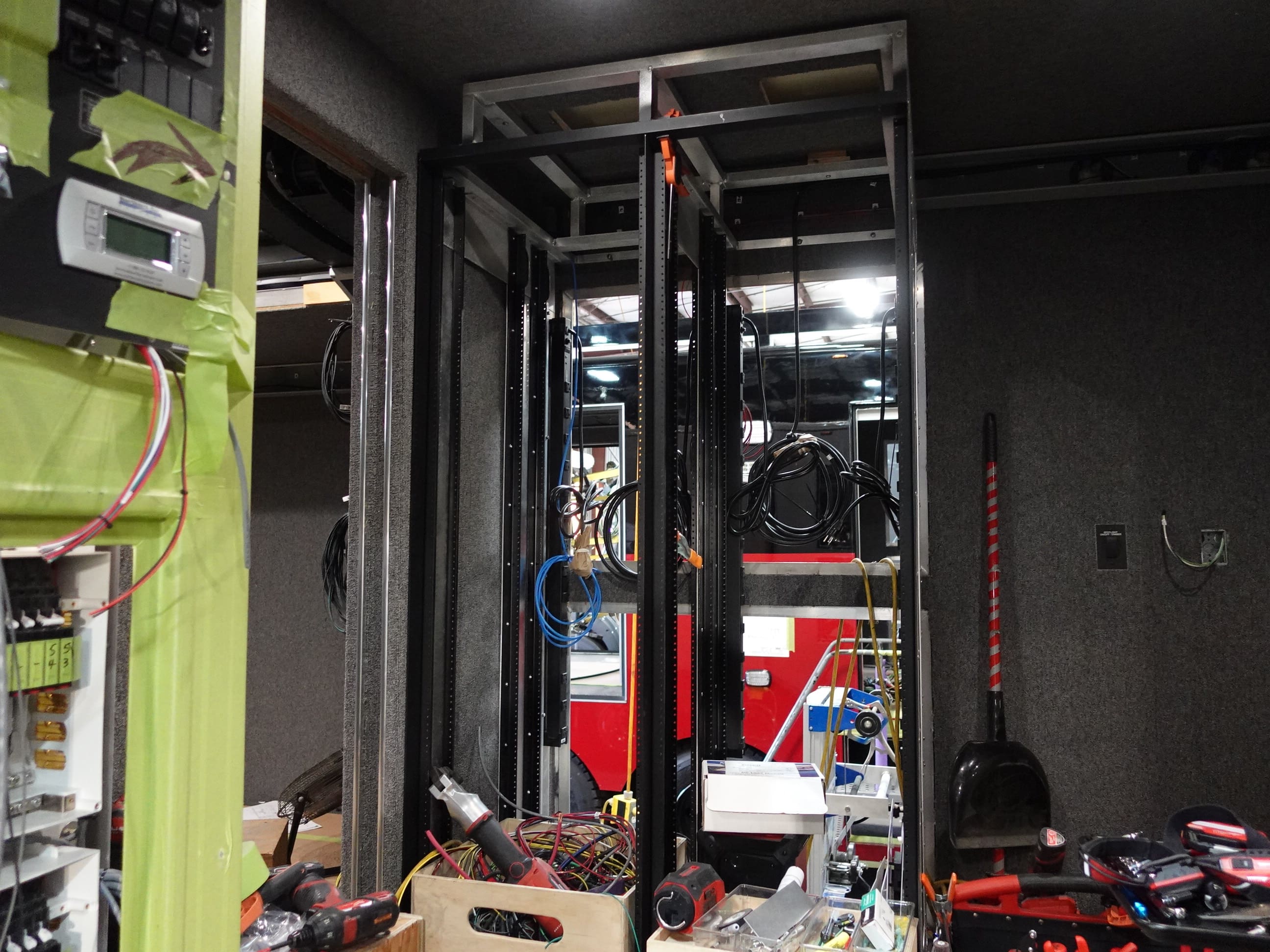

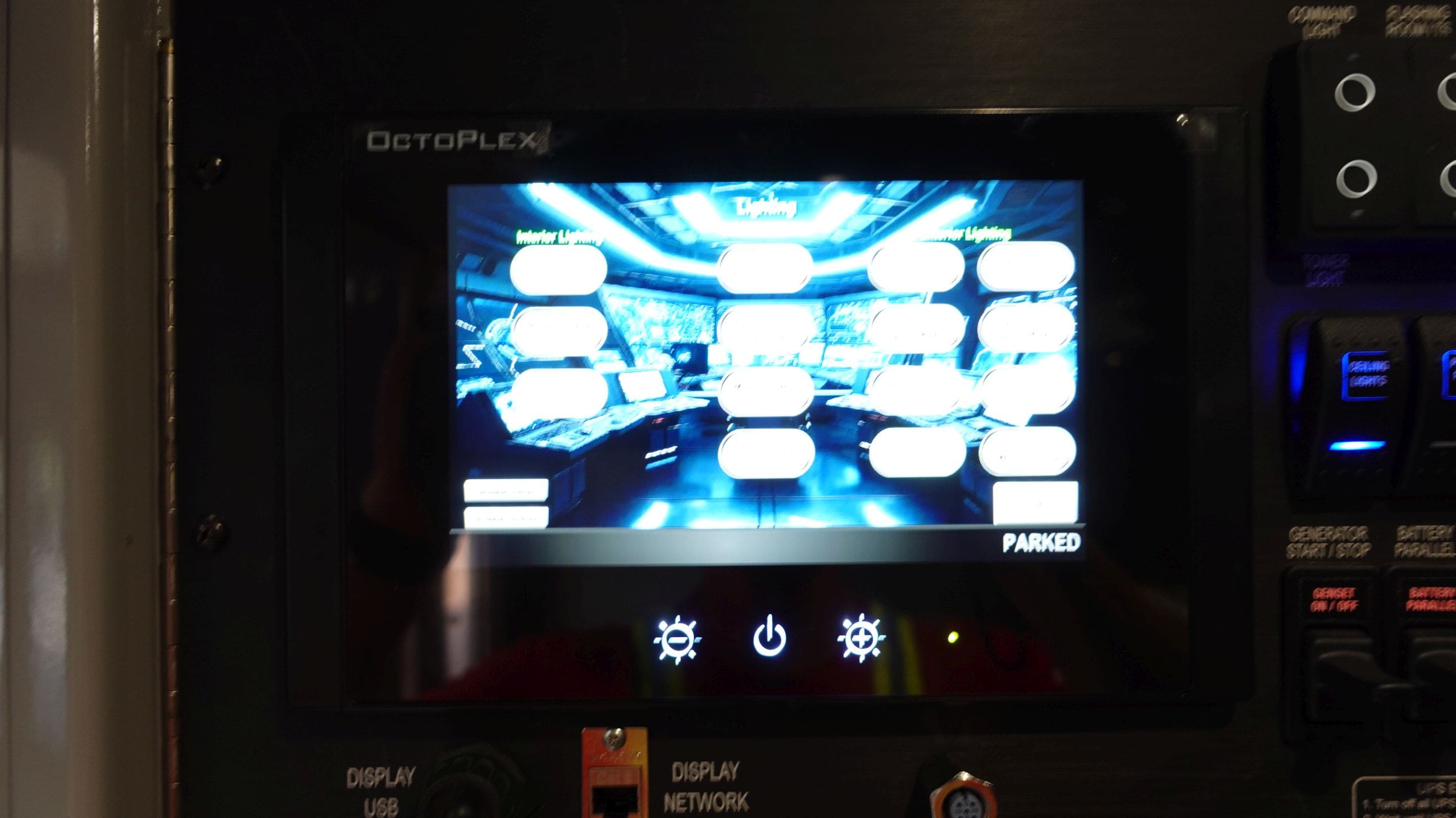

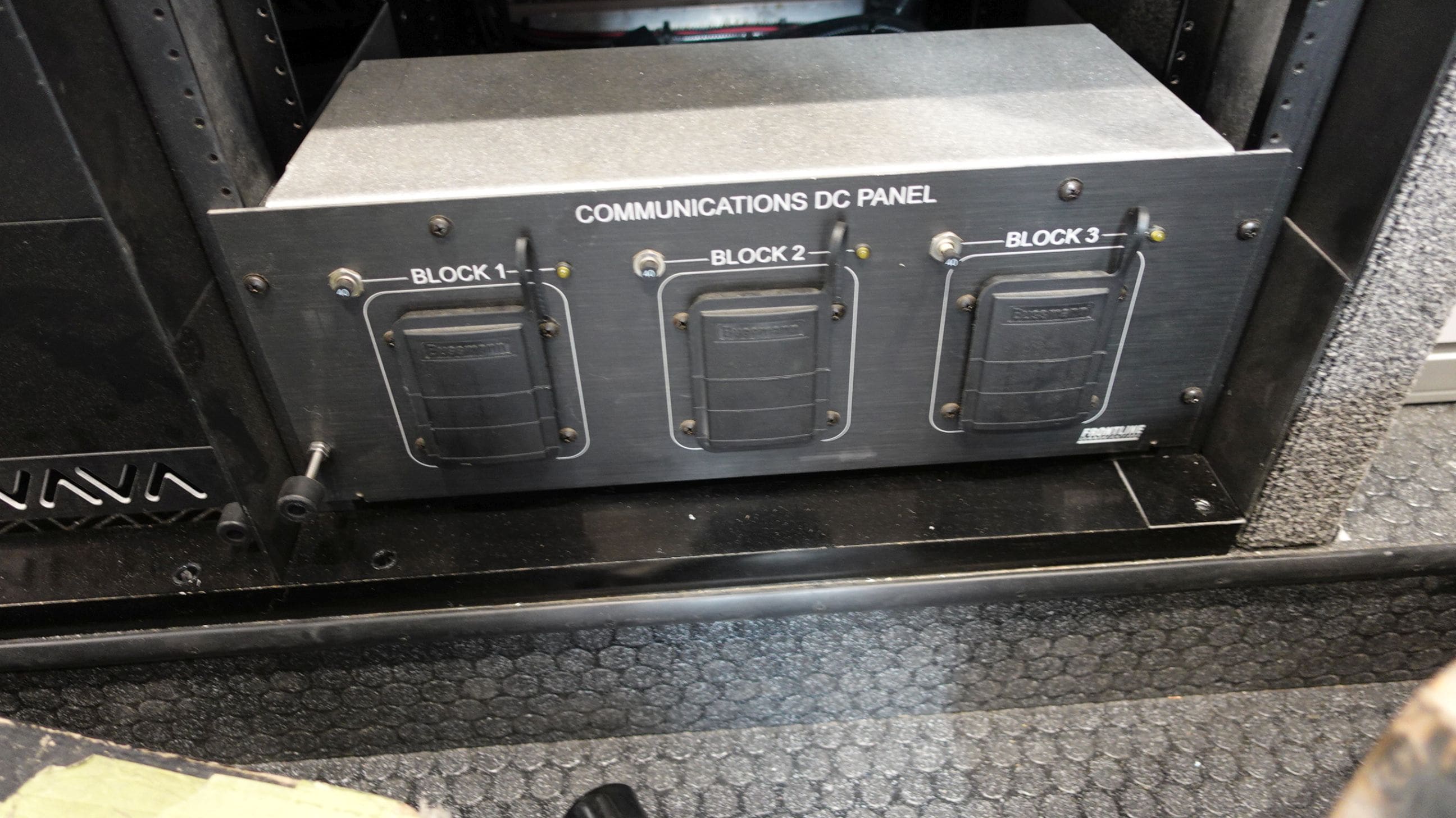

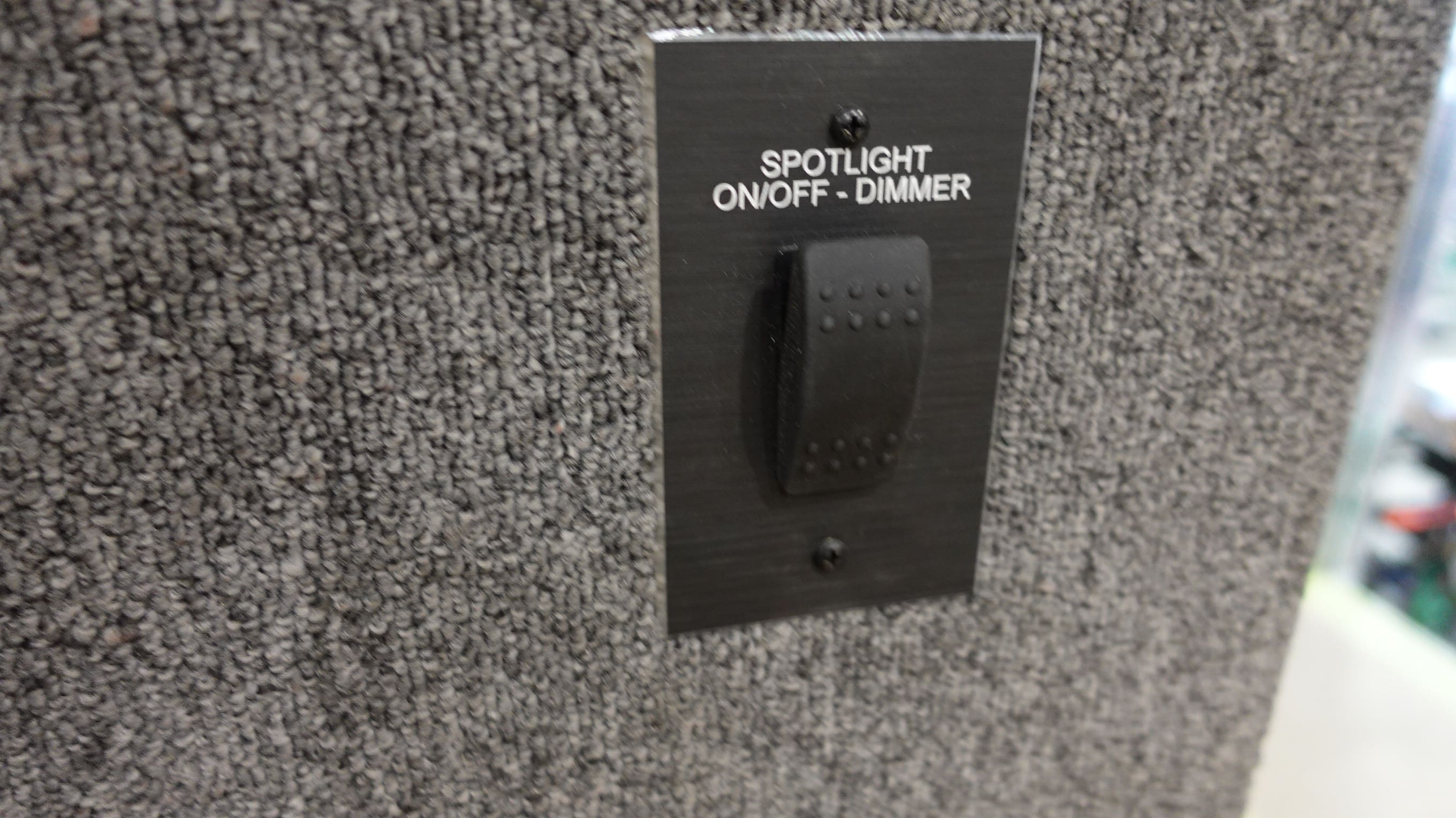

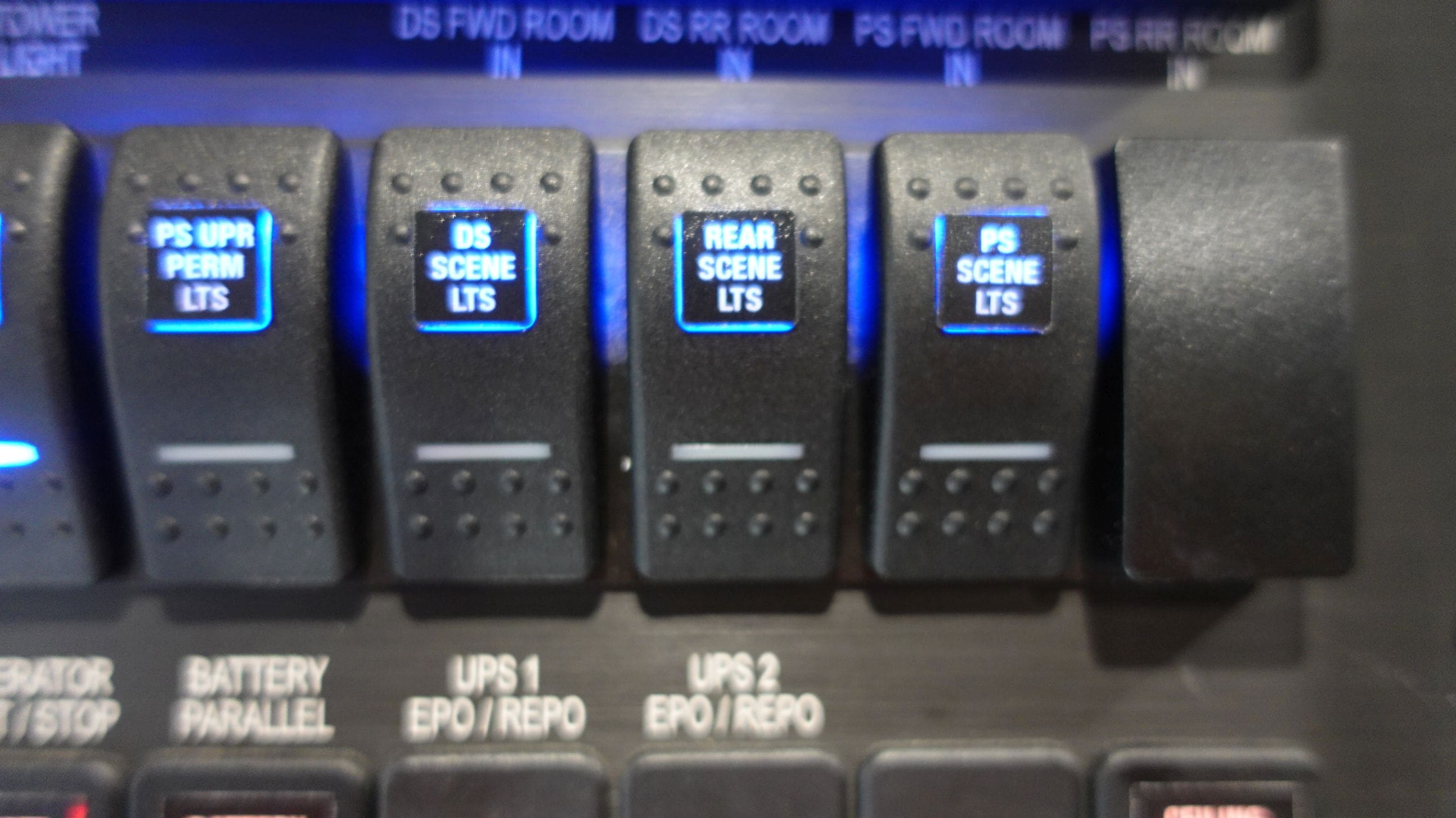

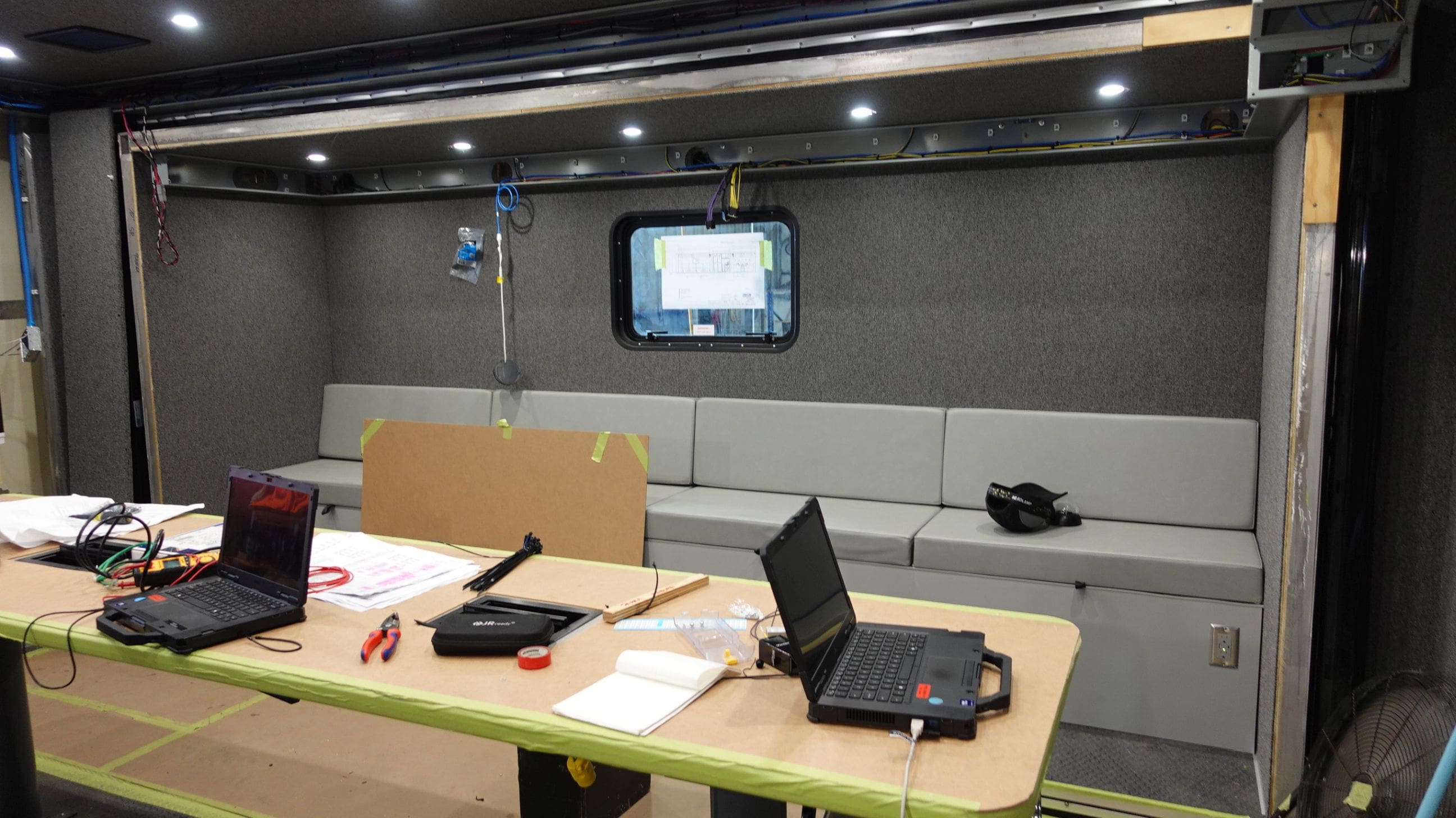

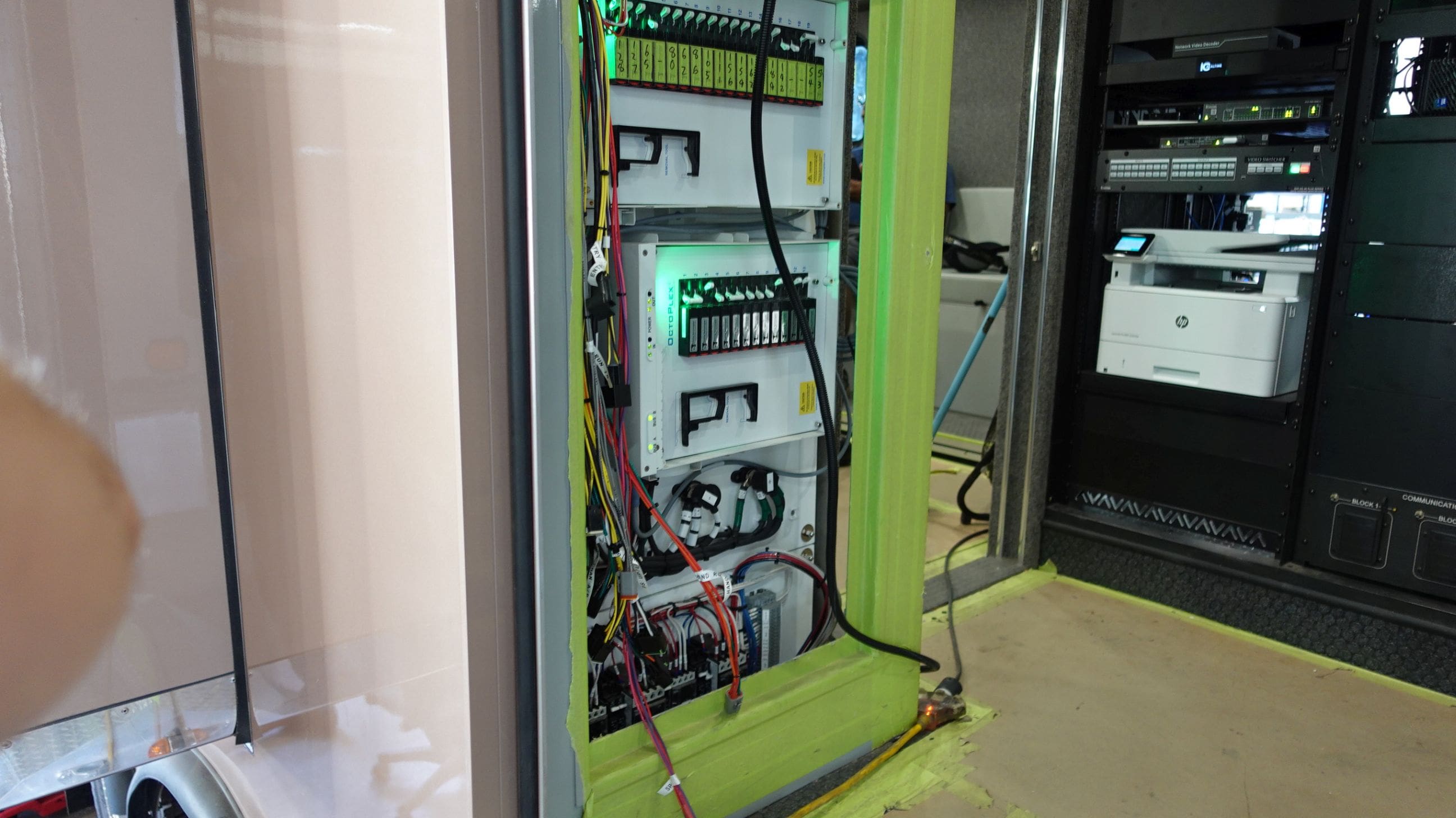

In this report, the apparatus continued the integration

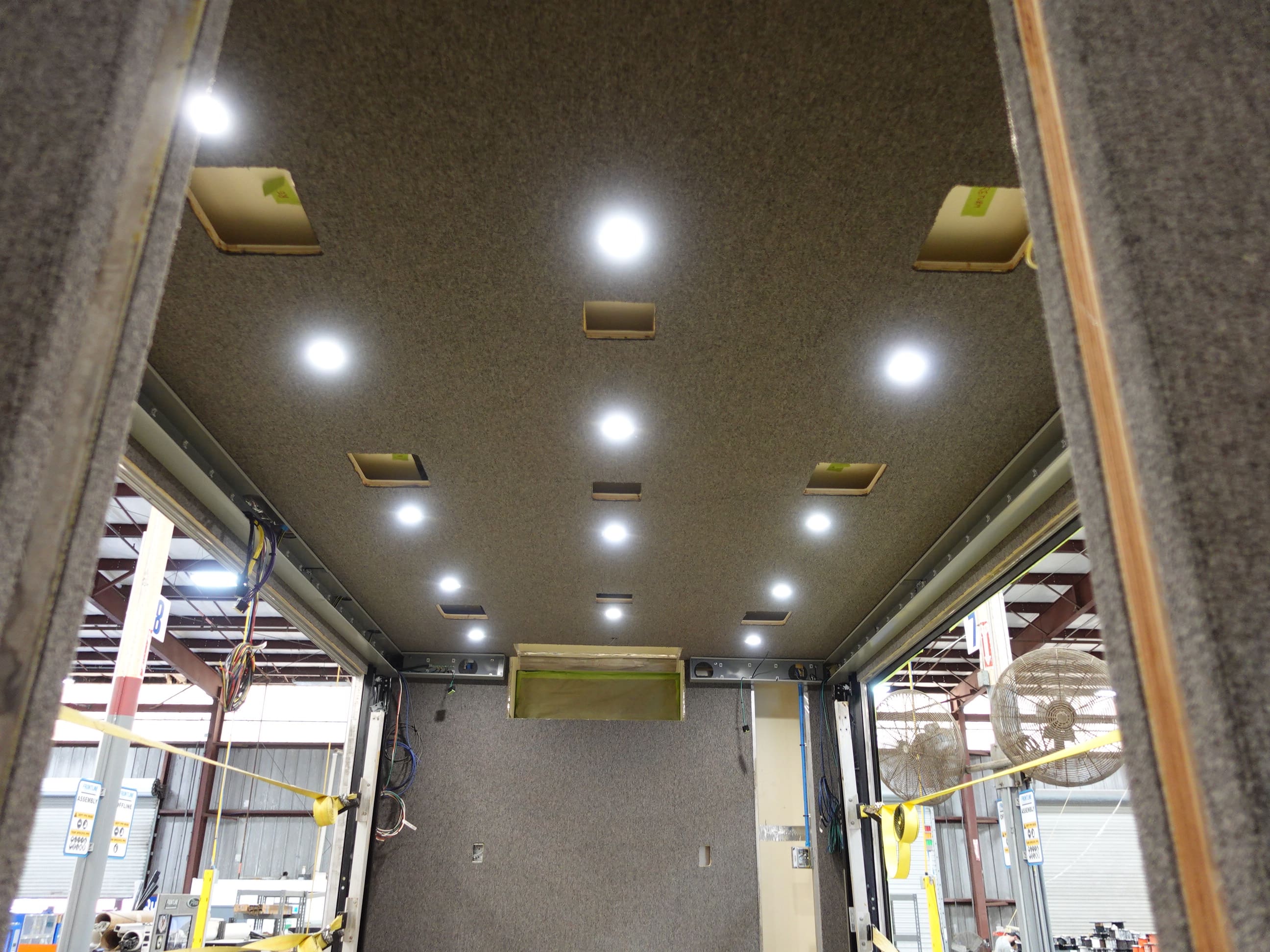

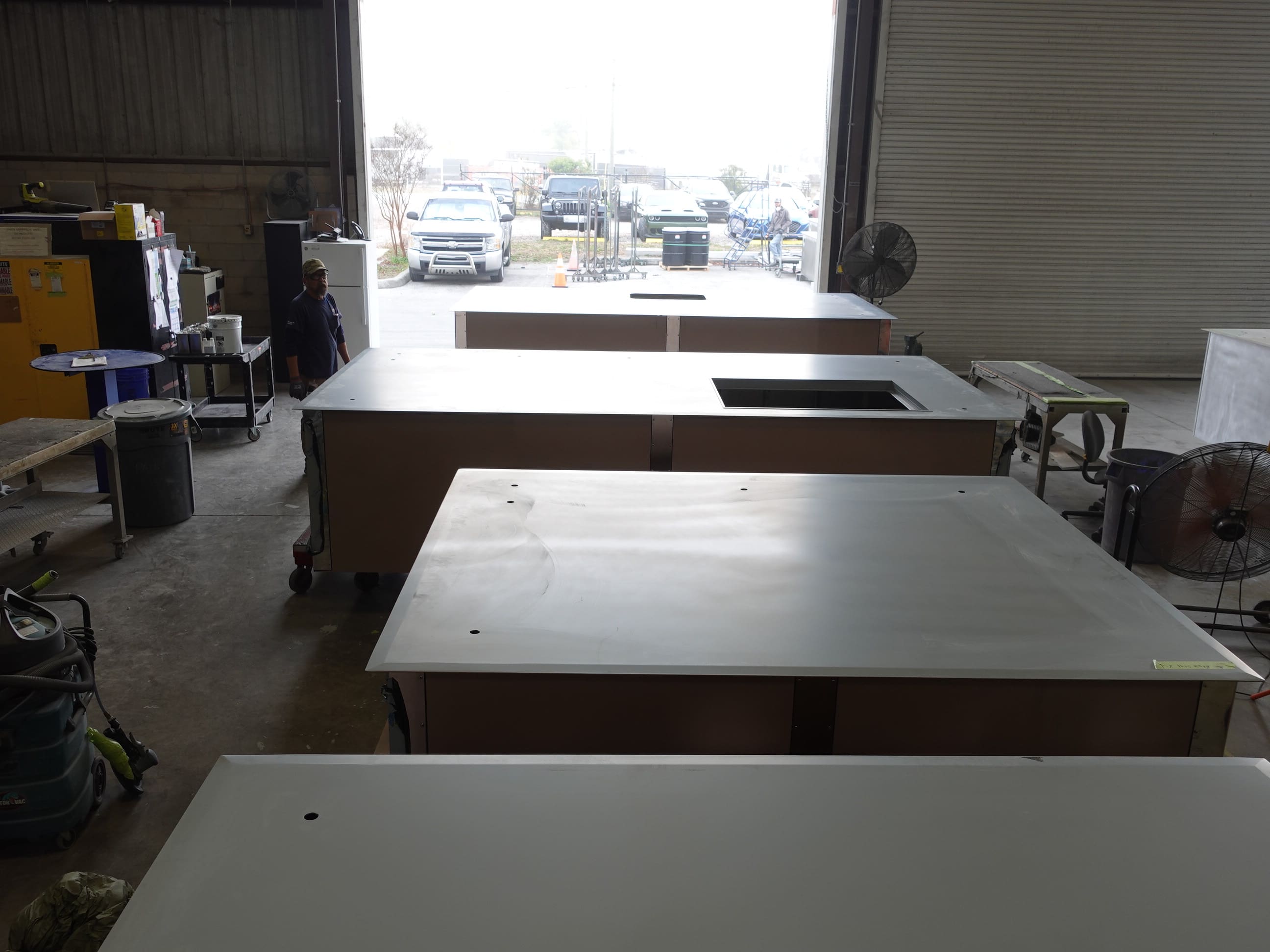

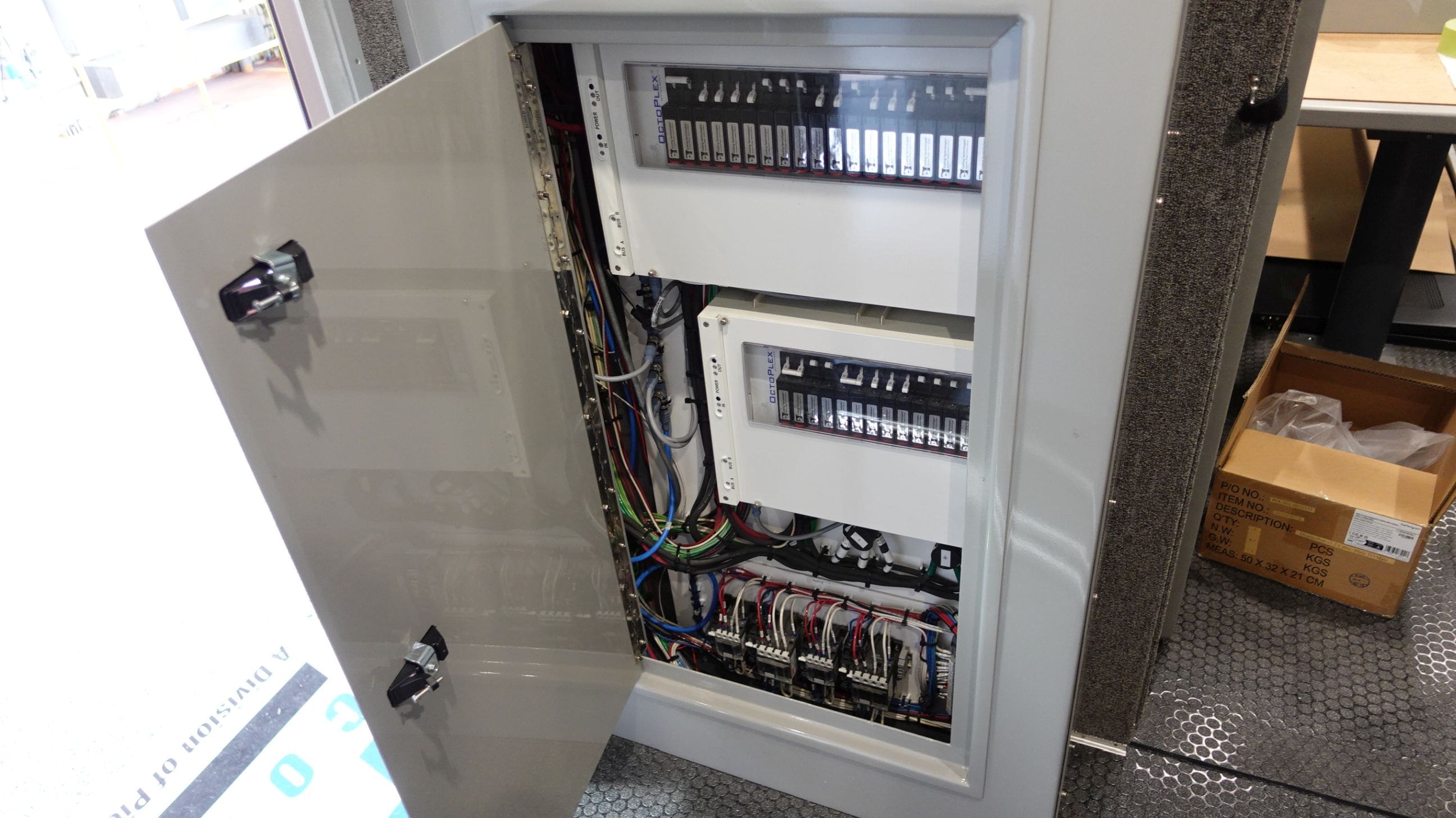

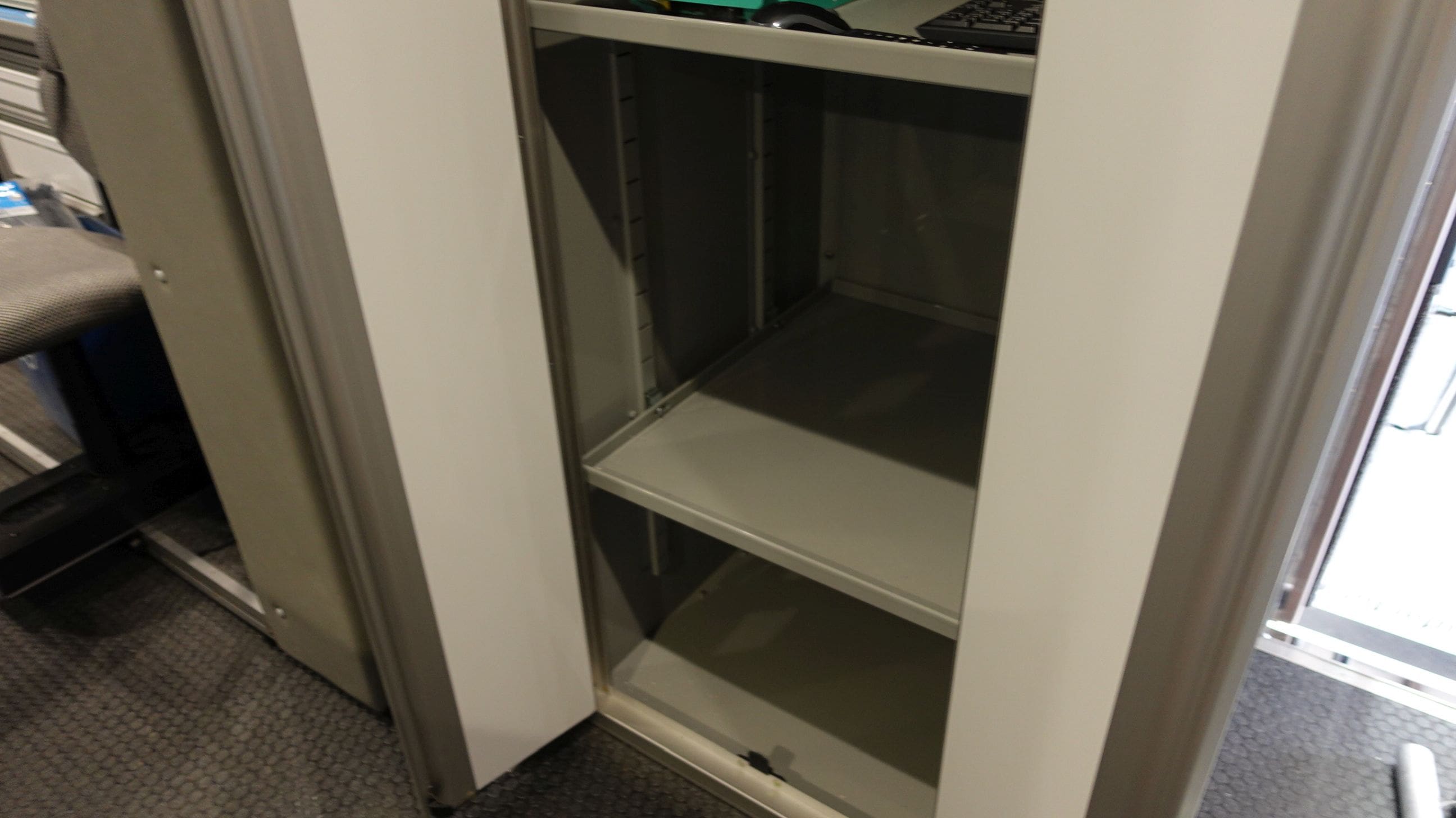

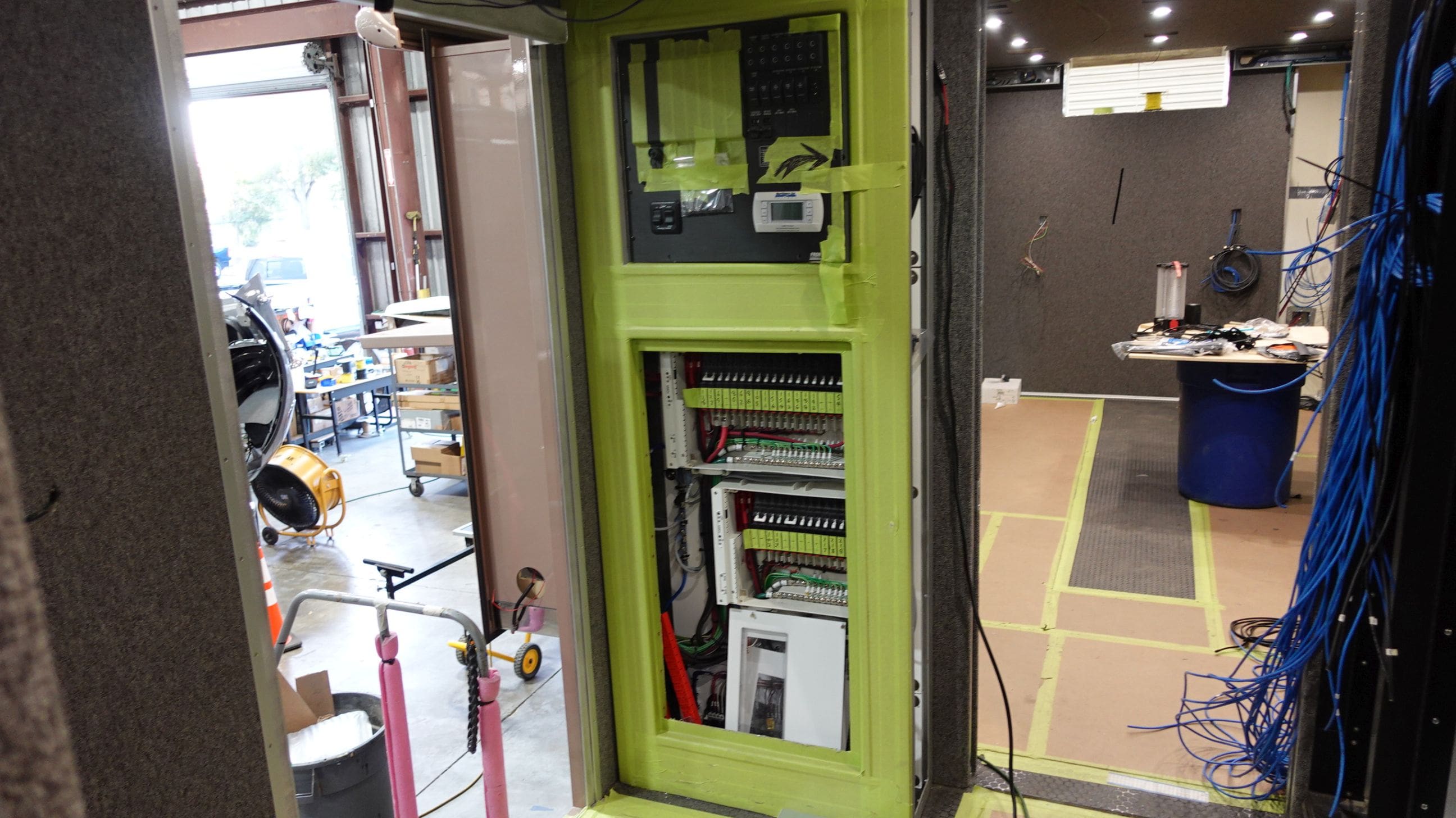

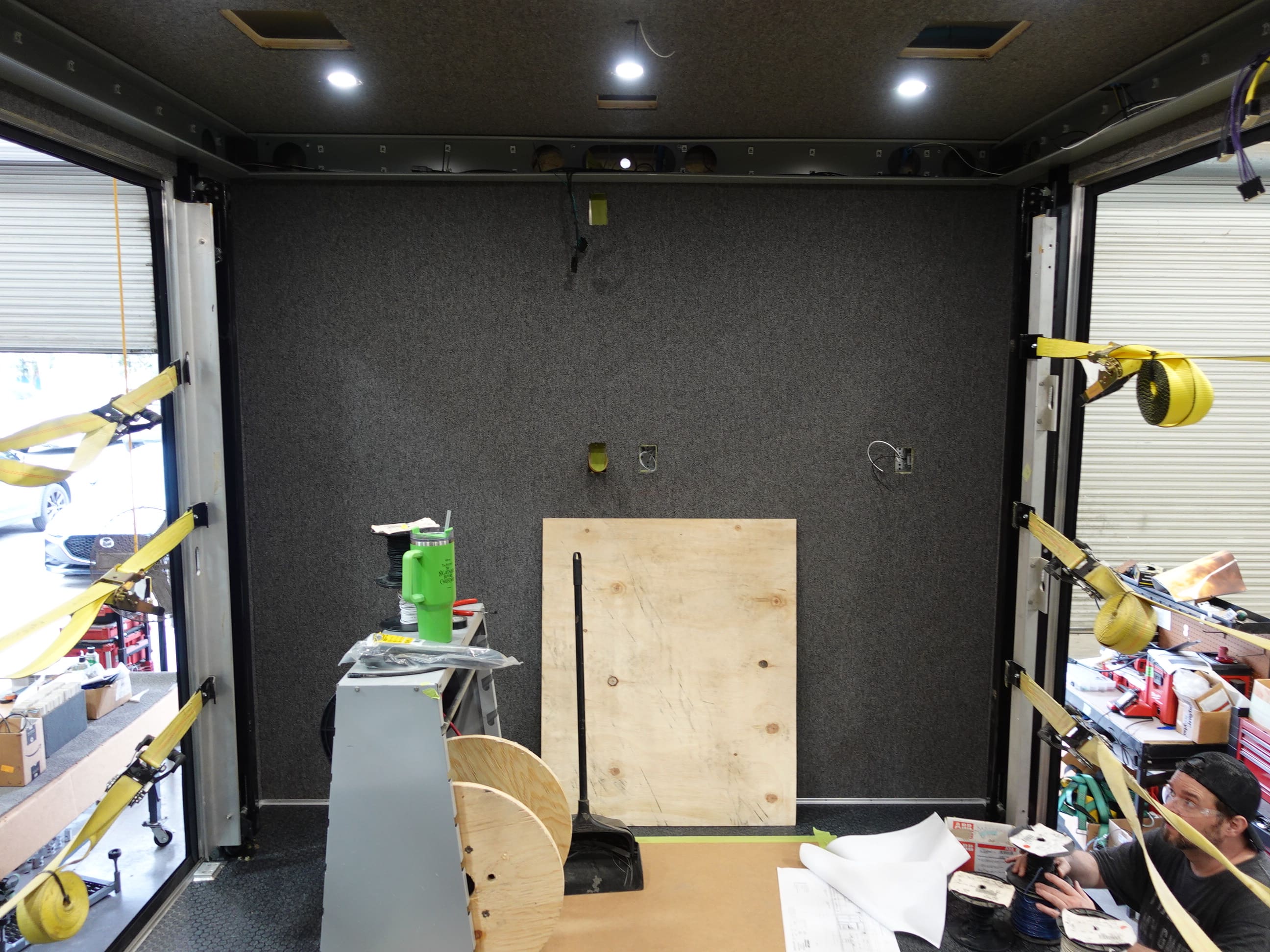

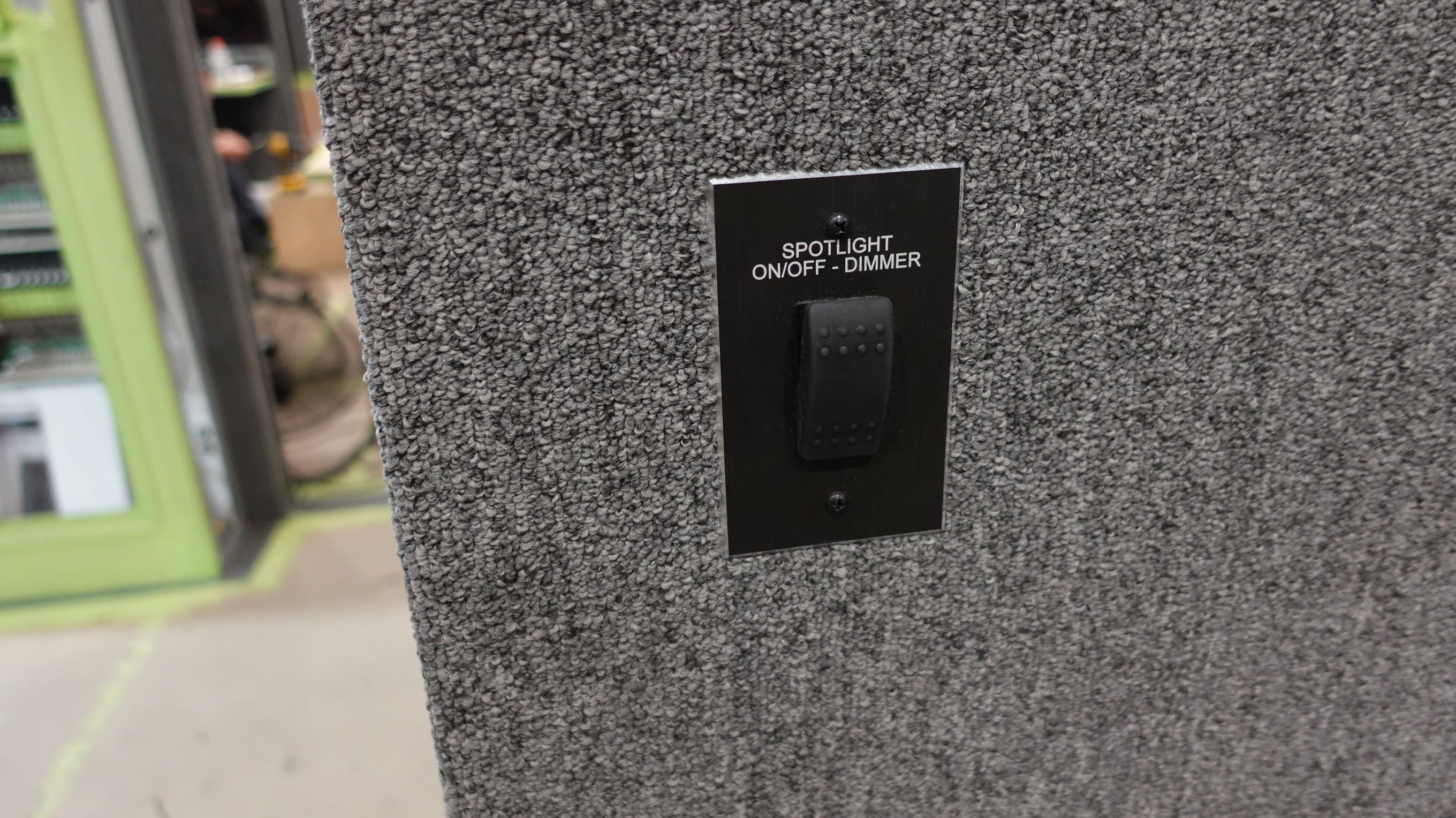

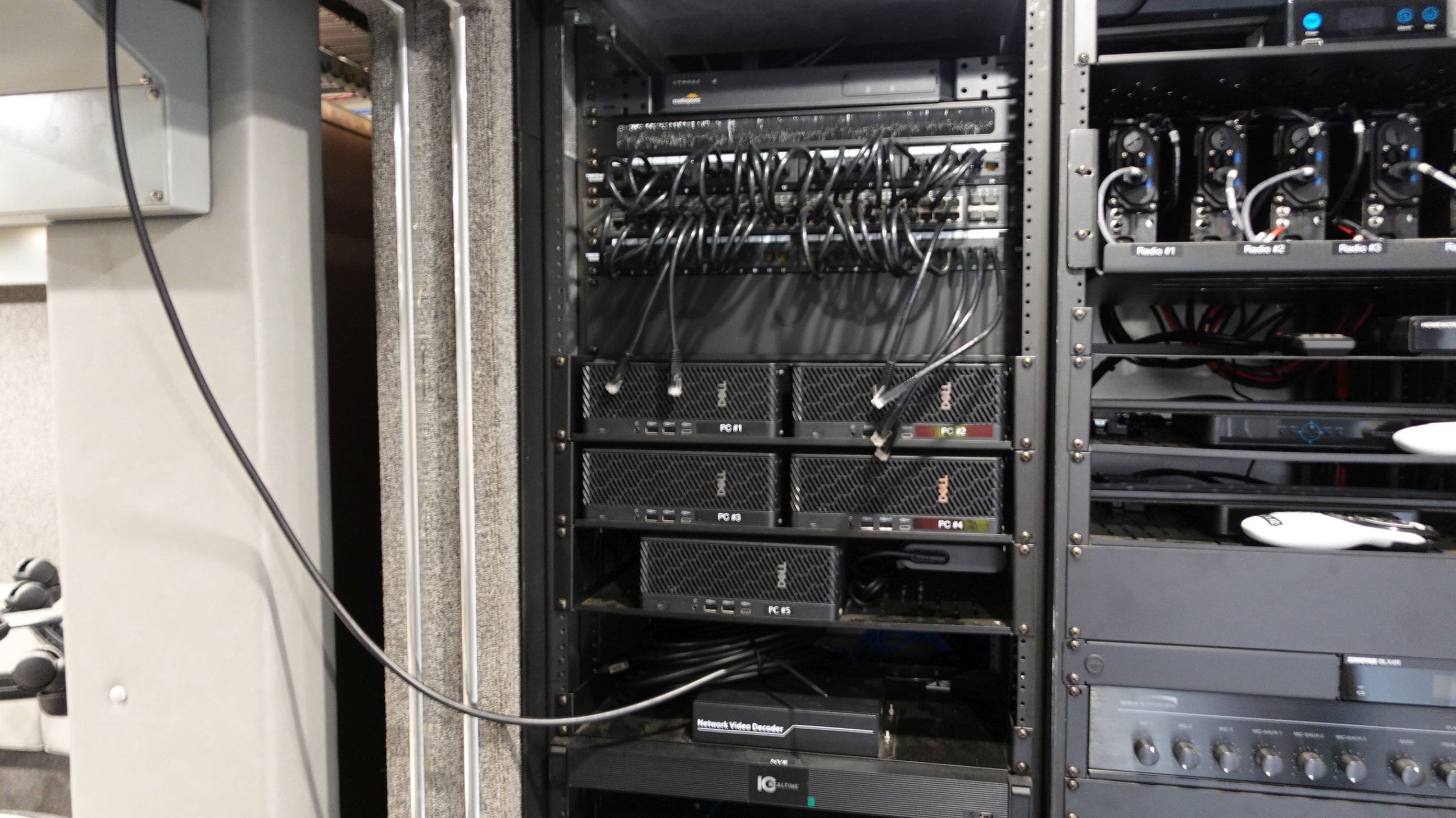

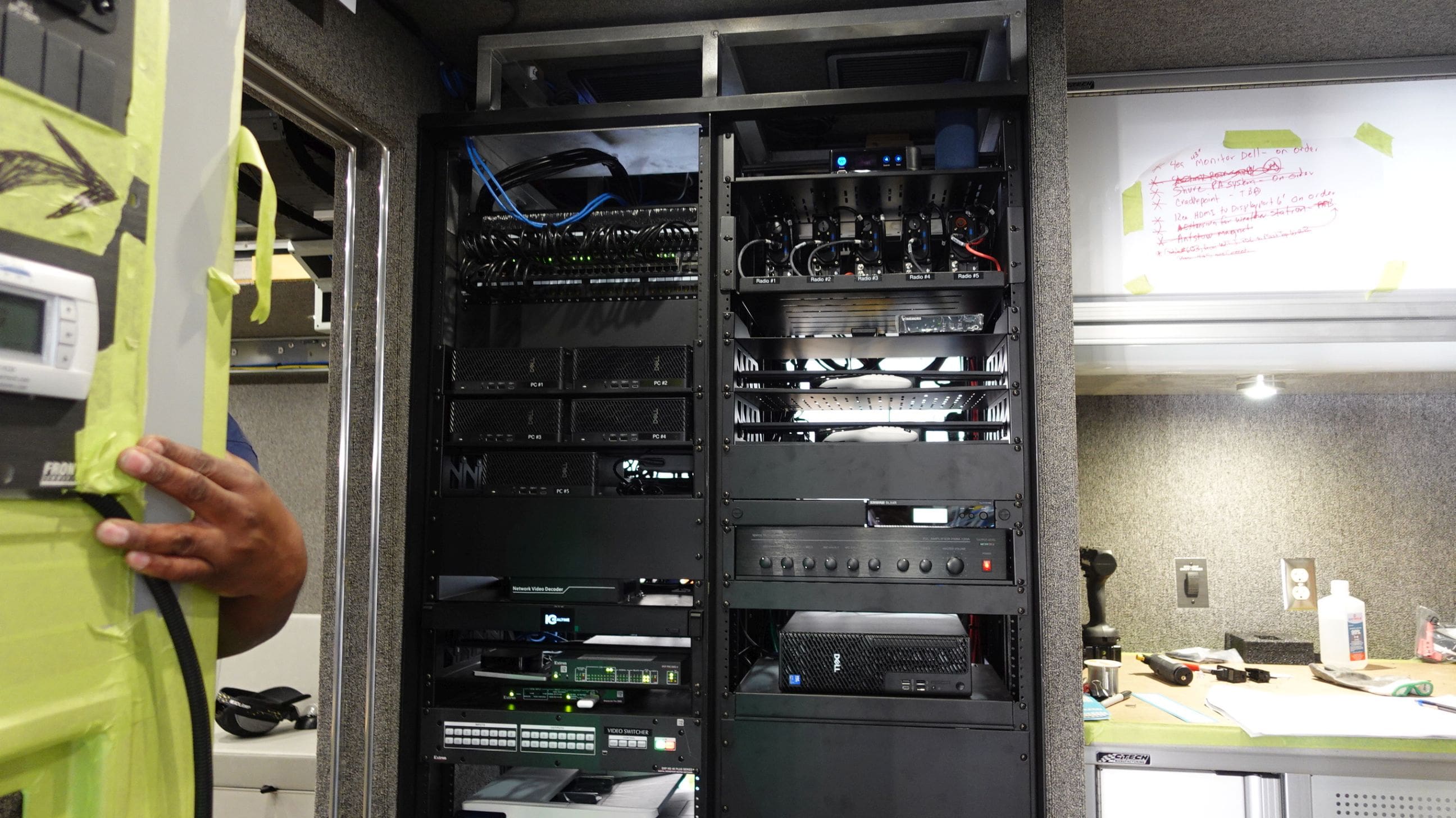

process. When integration is completed the apparatus will release to quality and graphics where any remaining content will be applied. Once finished

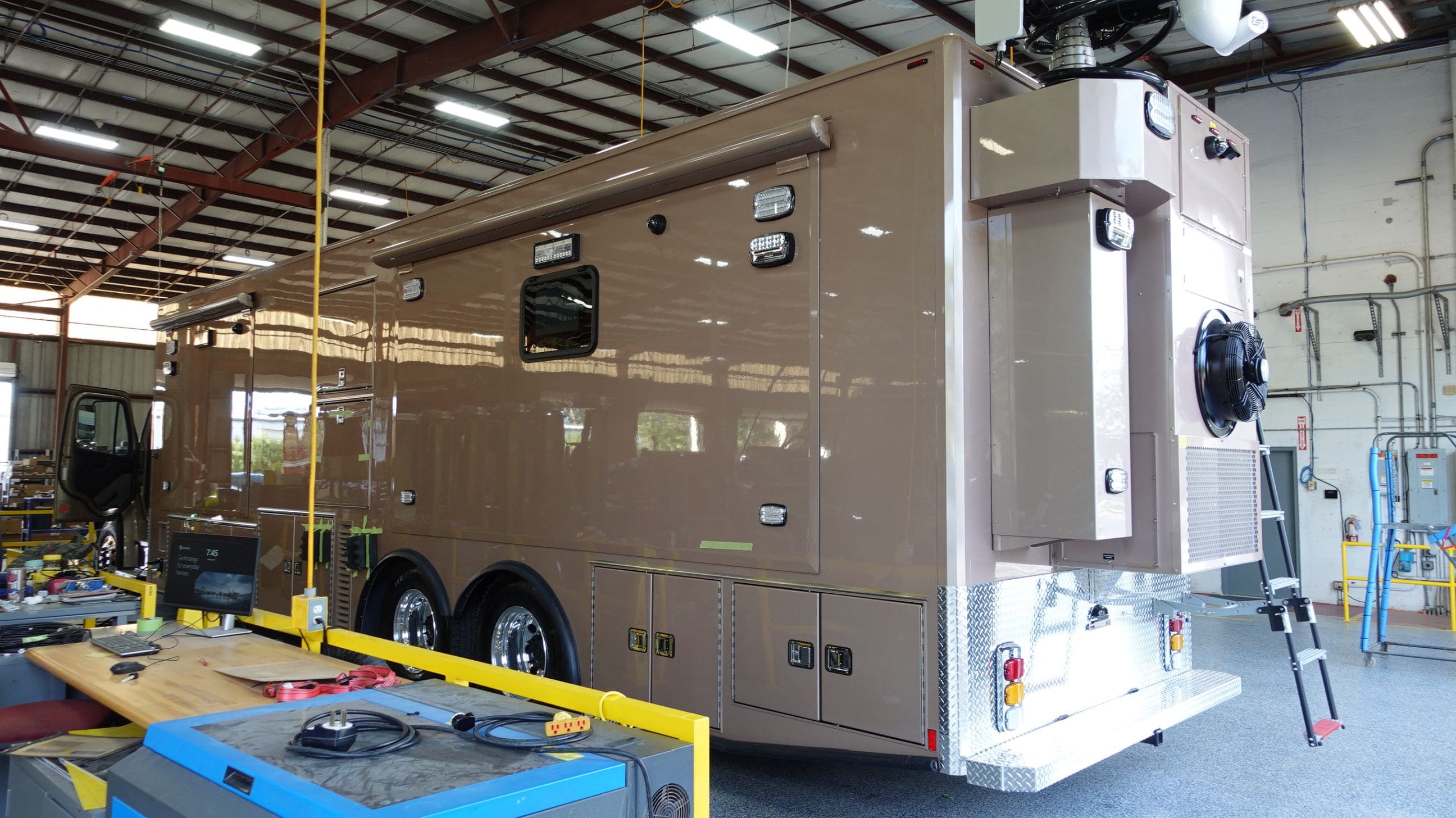

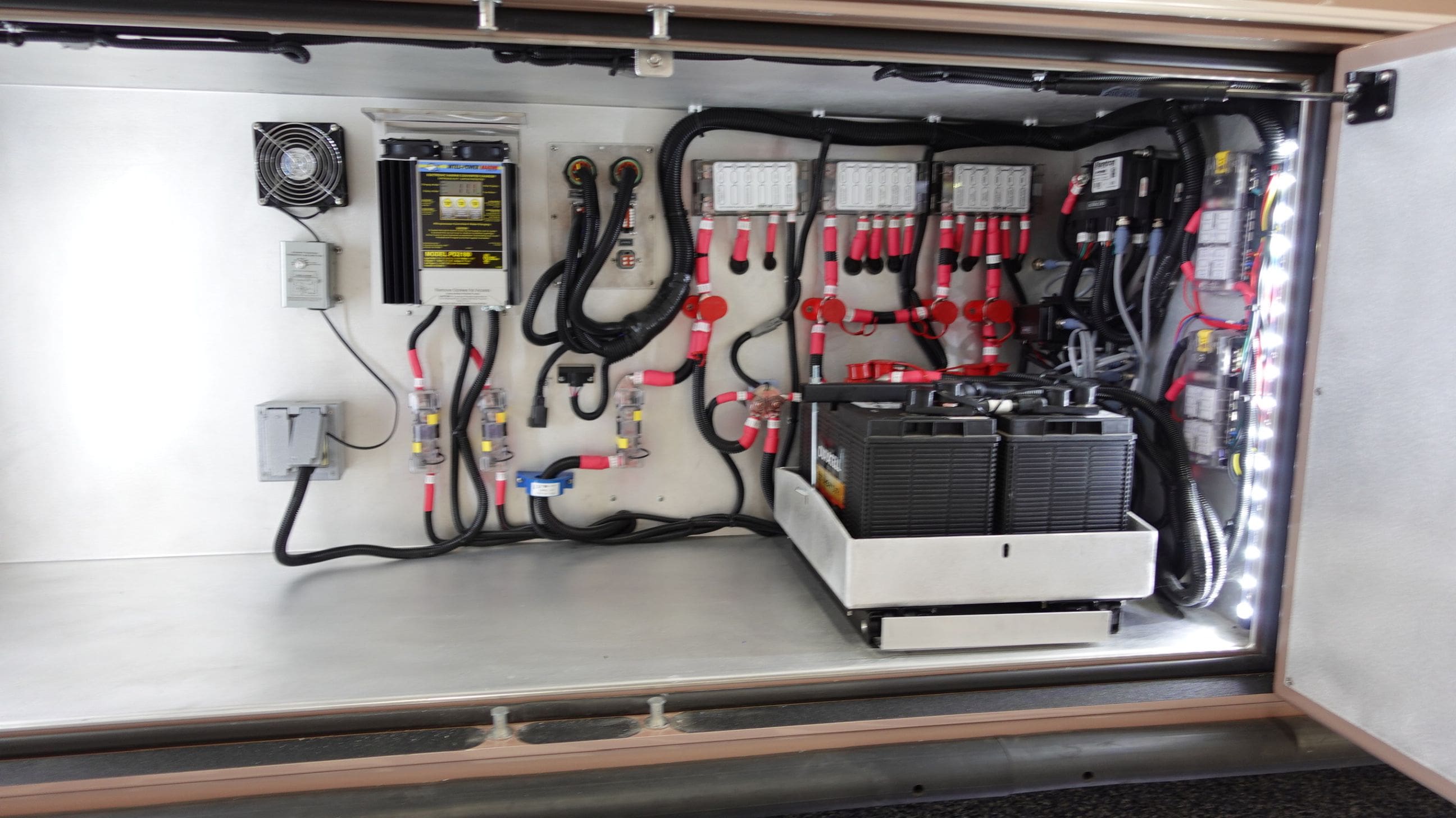

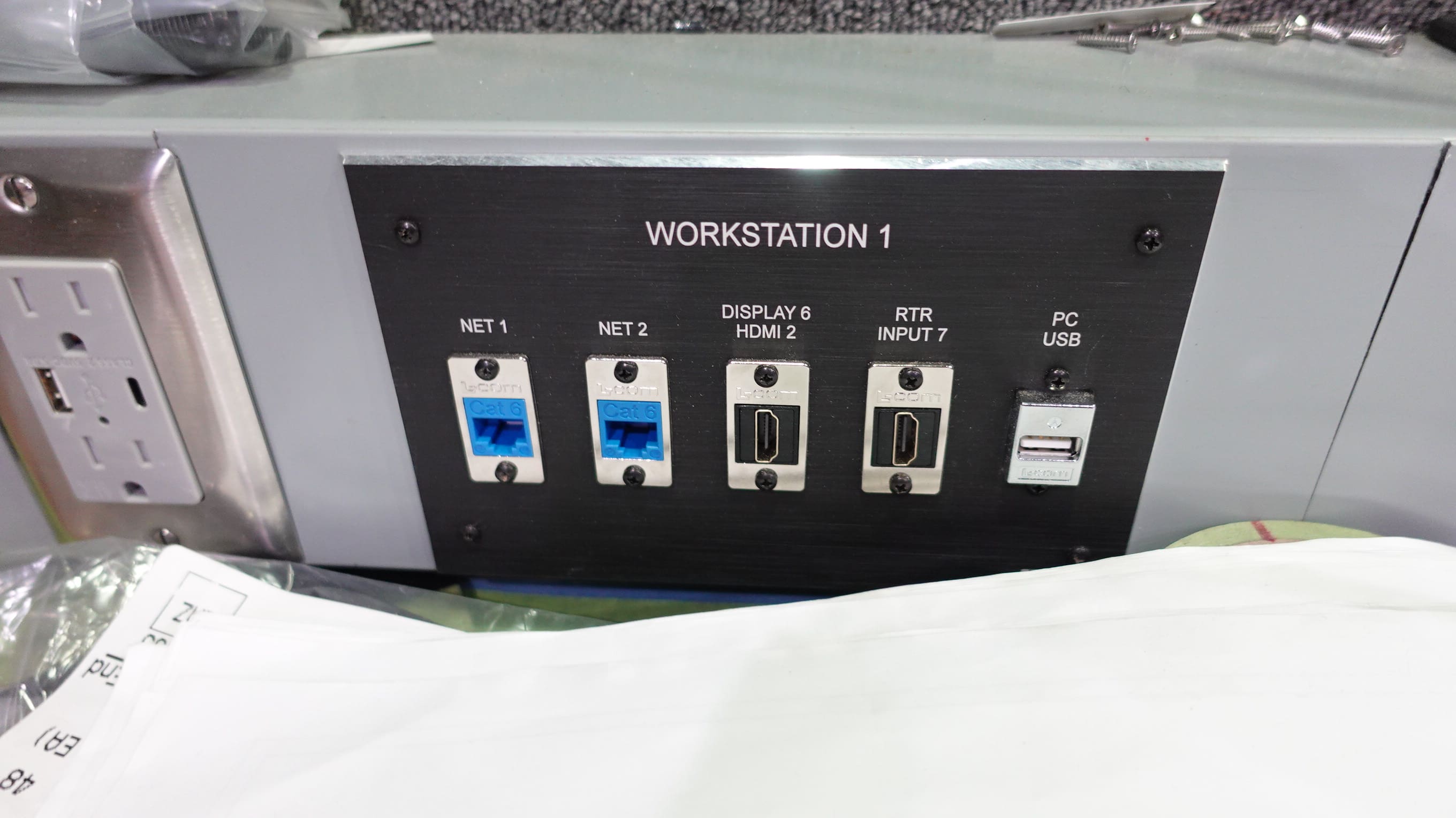

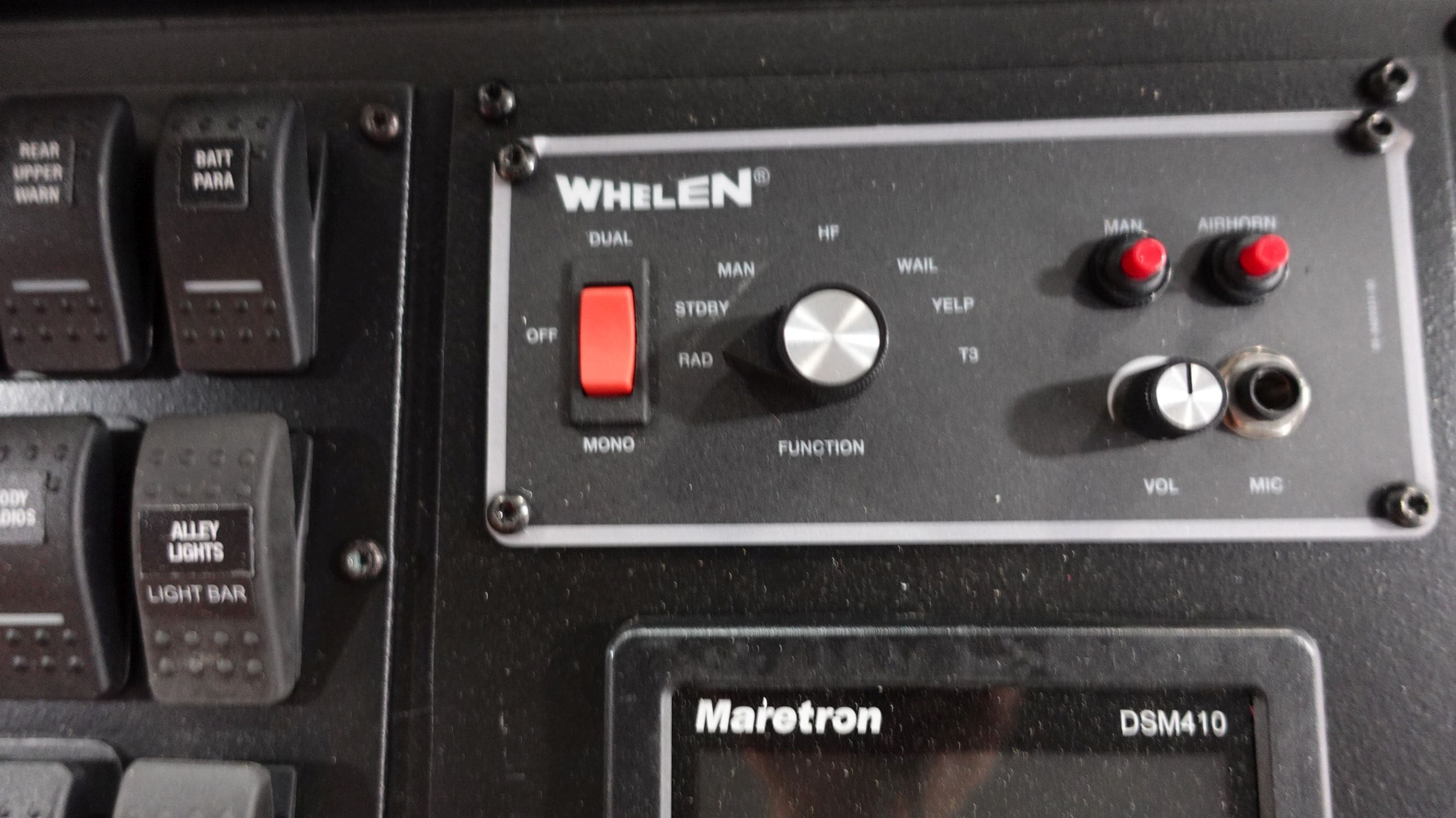

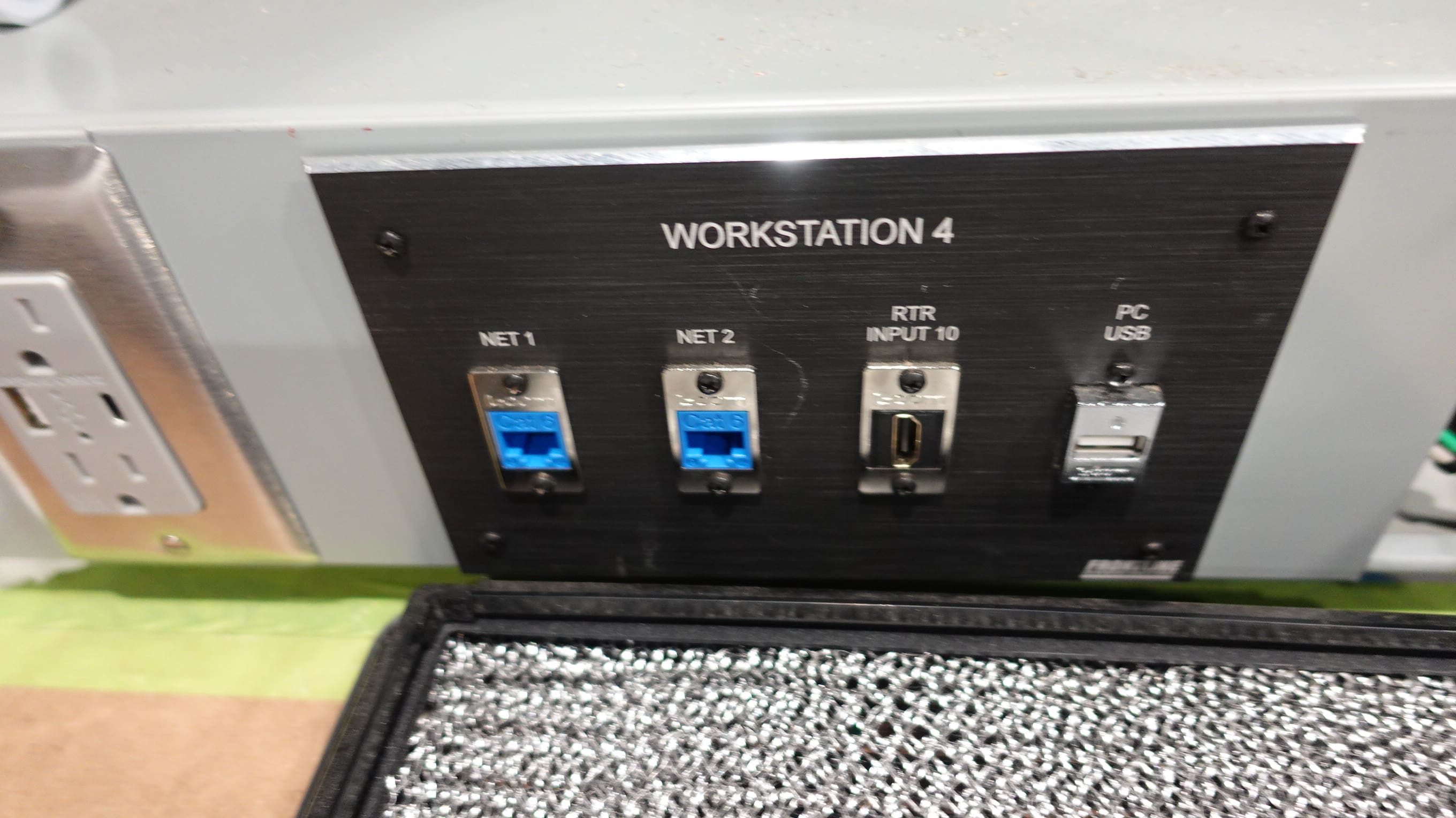

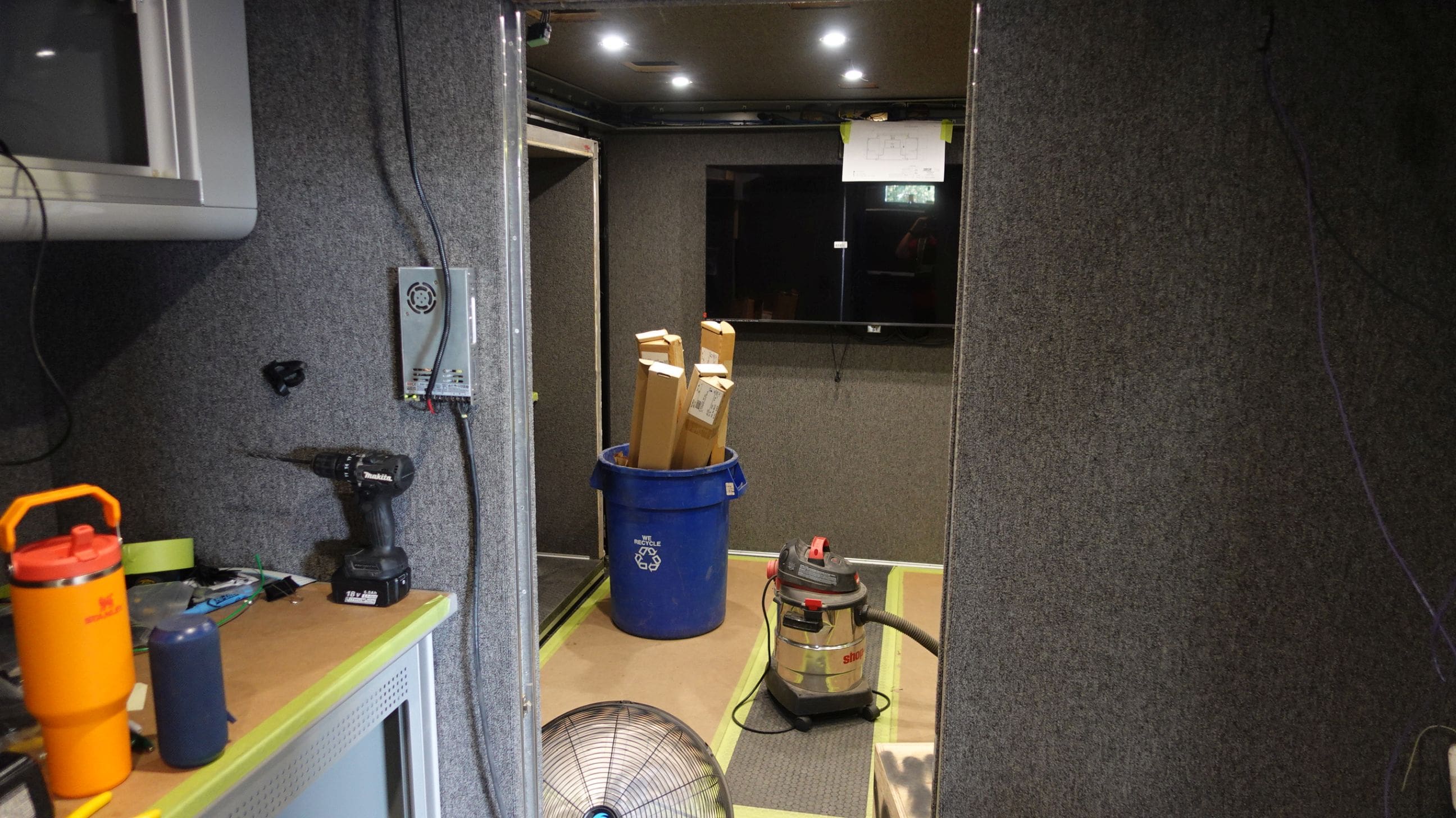

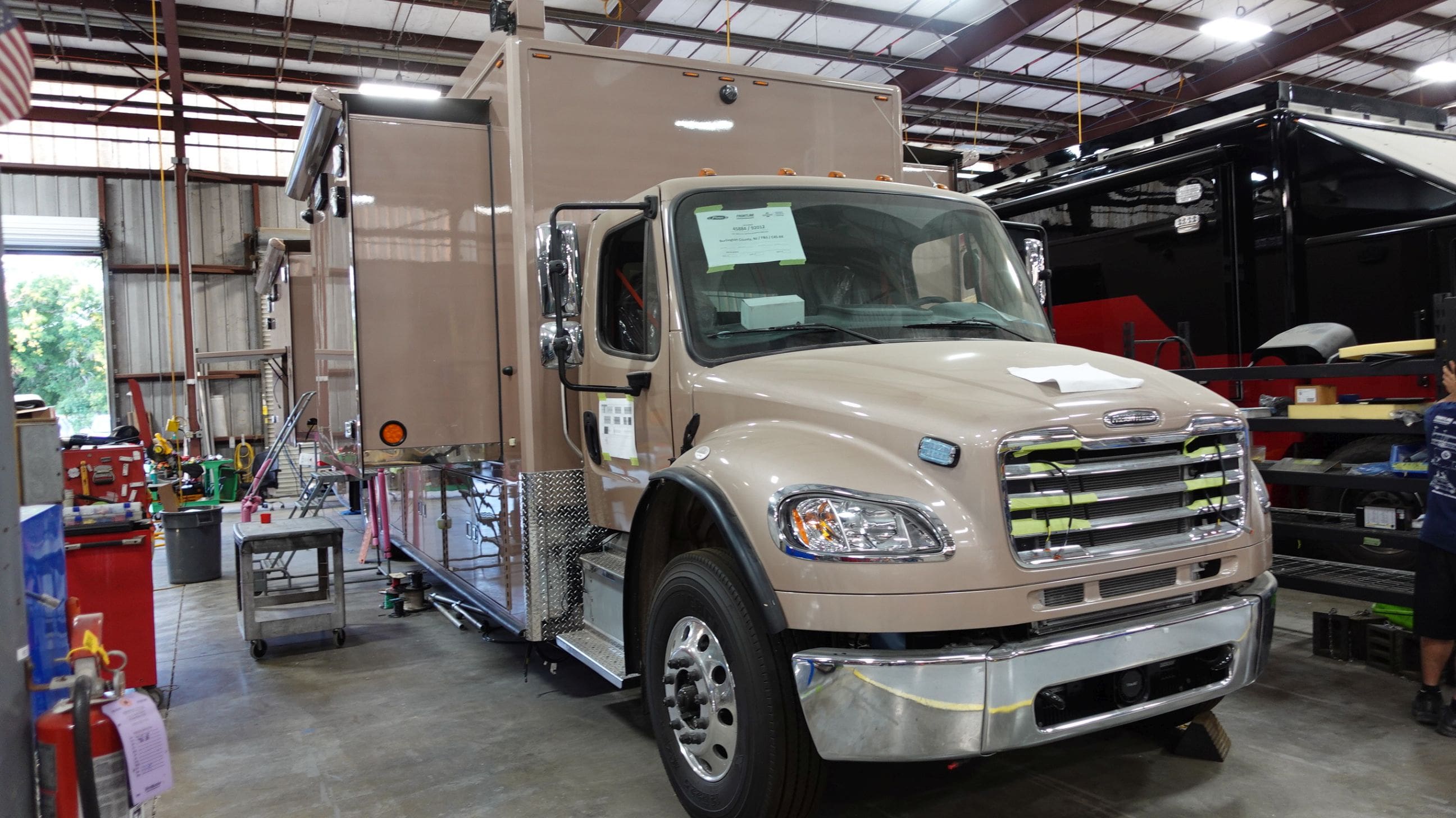

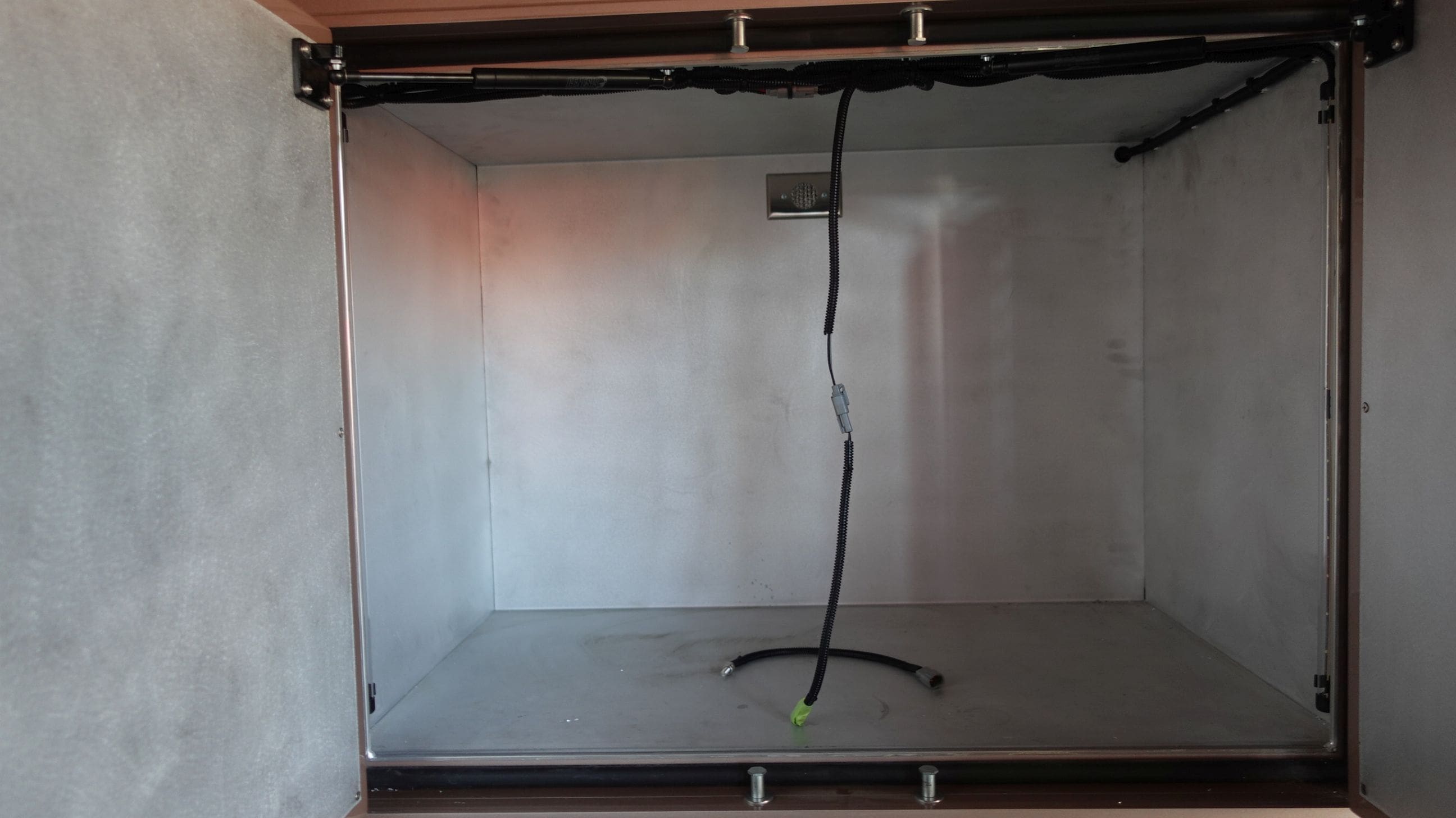

it will be made ready for the customer acceptance

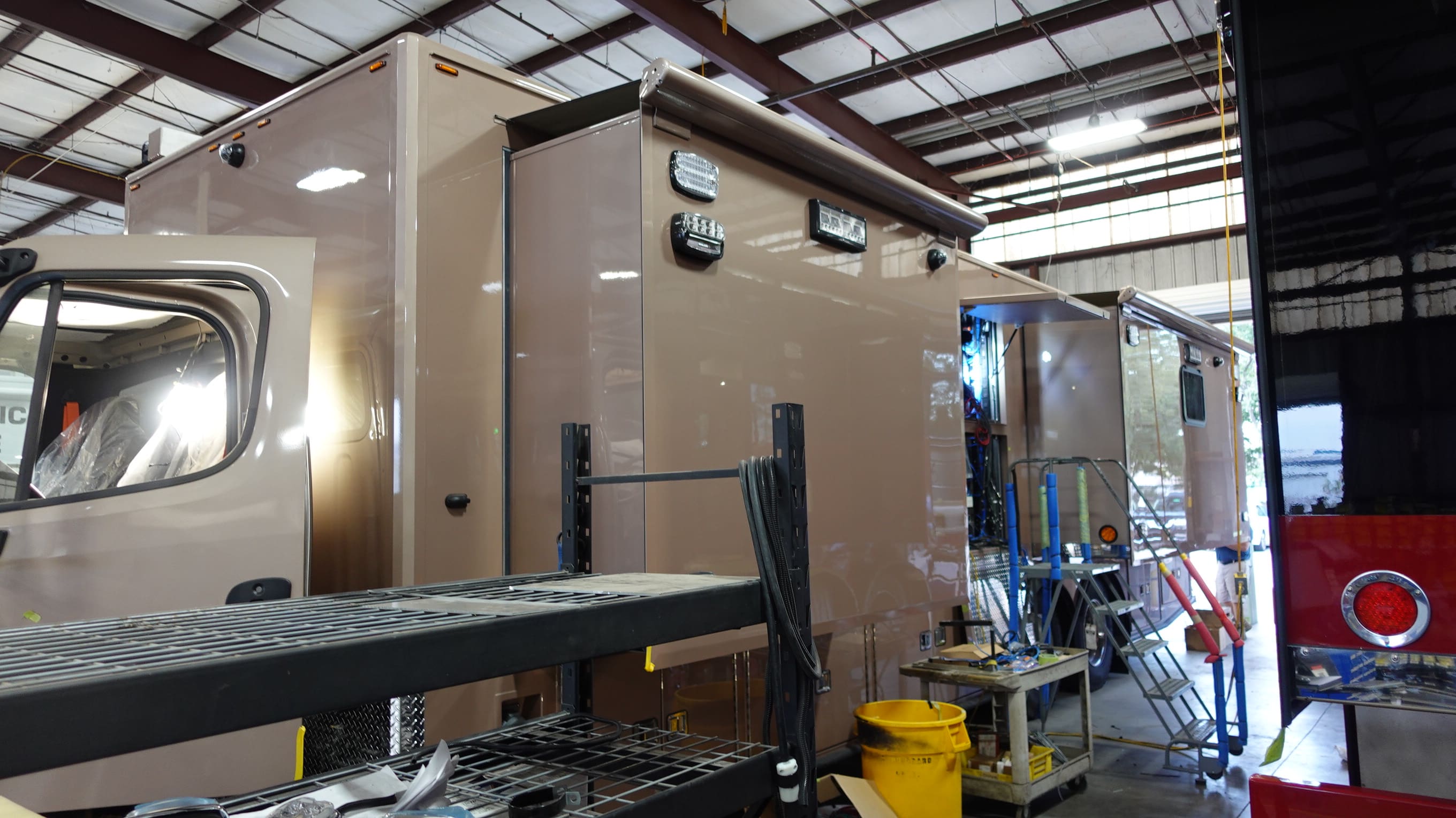

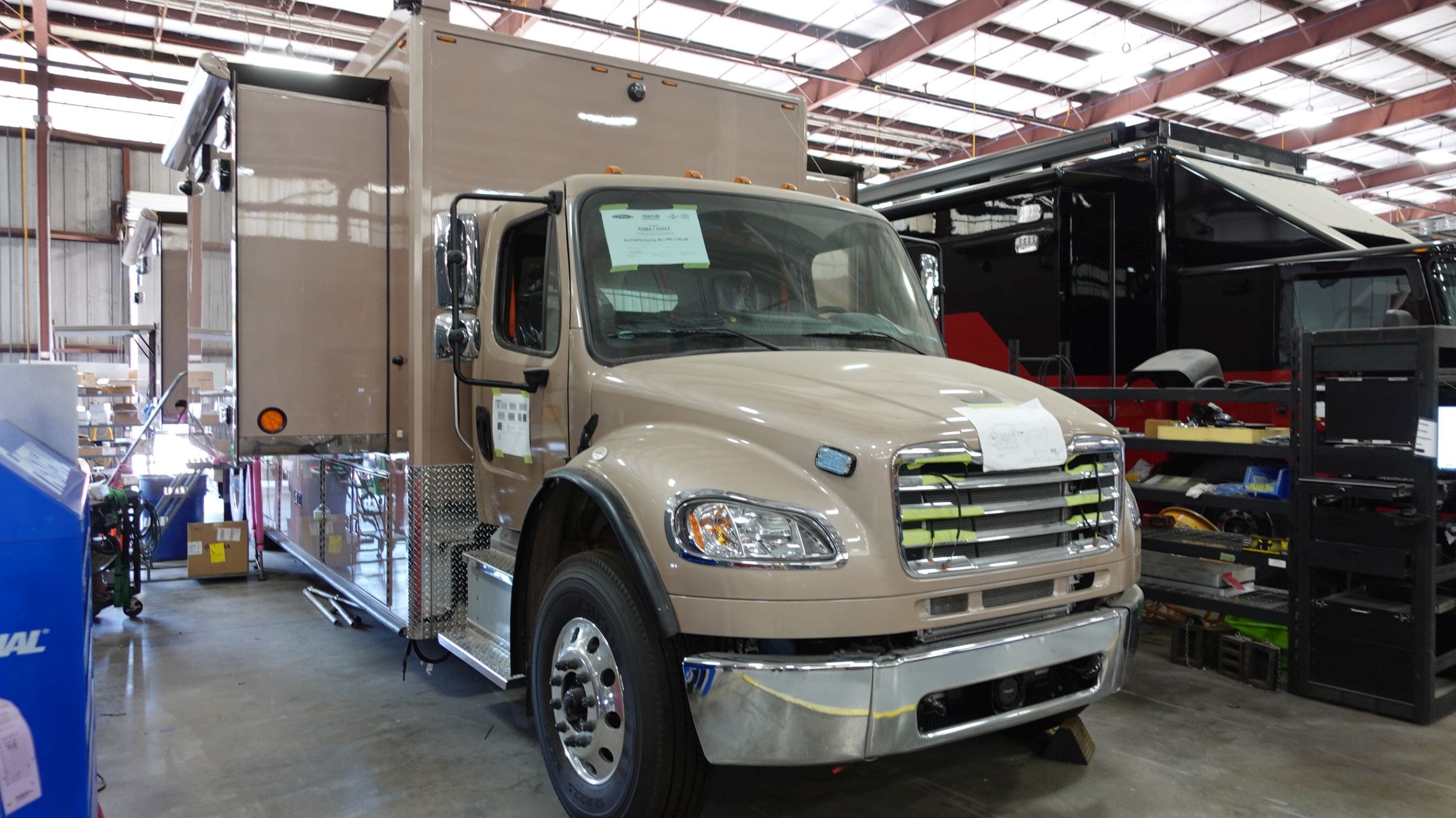

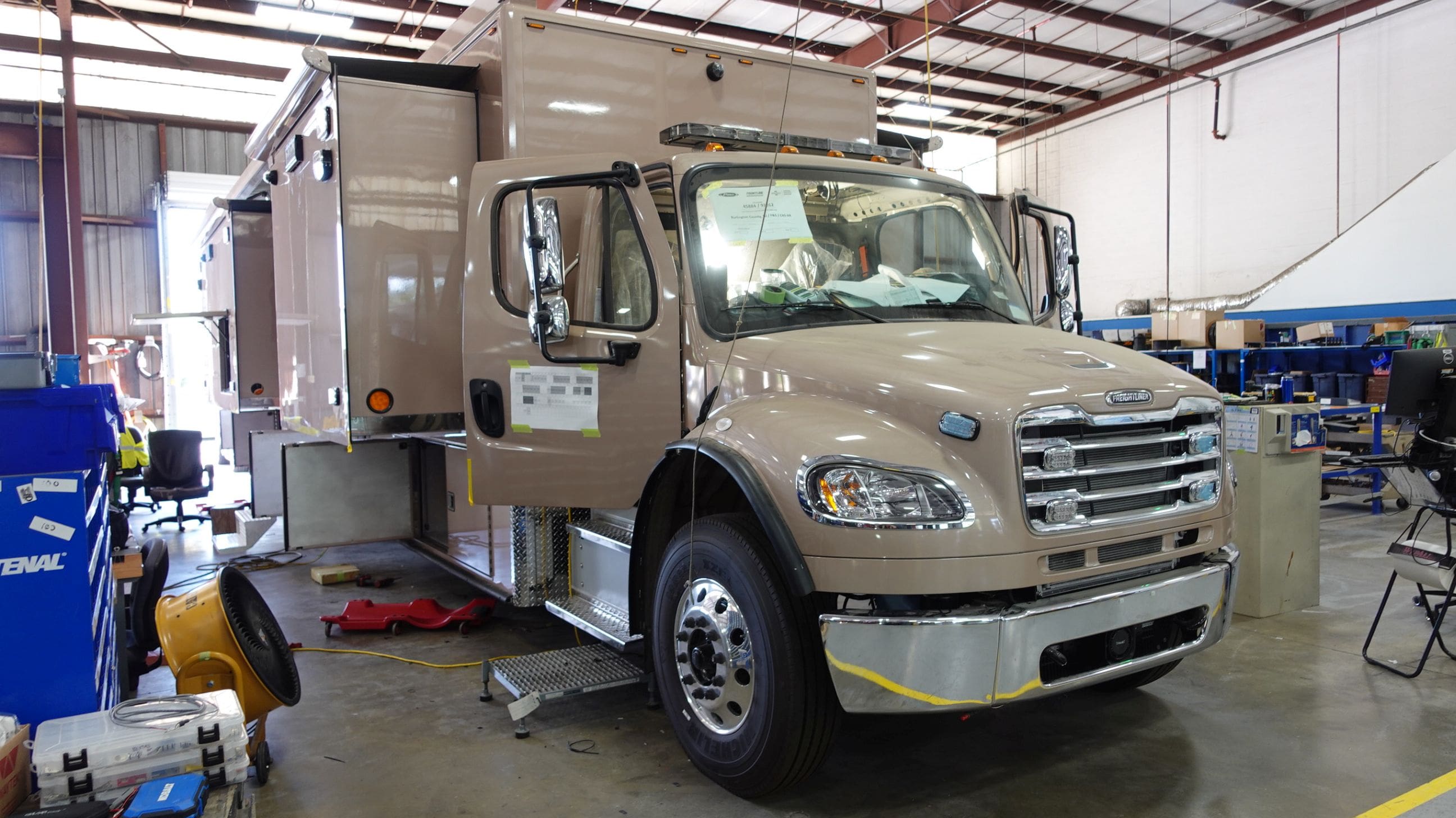

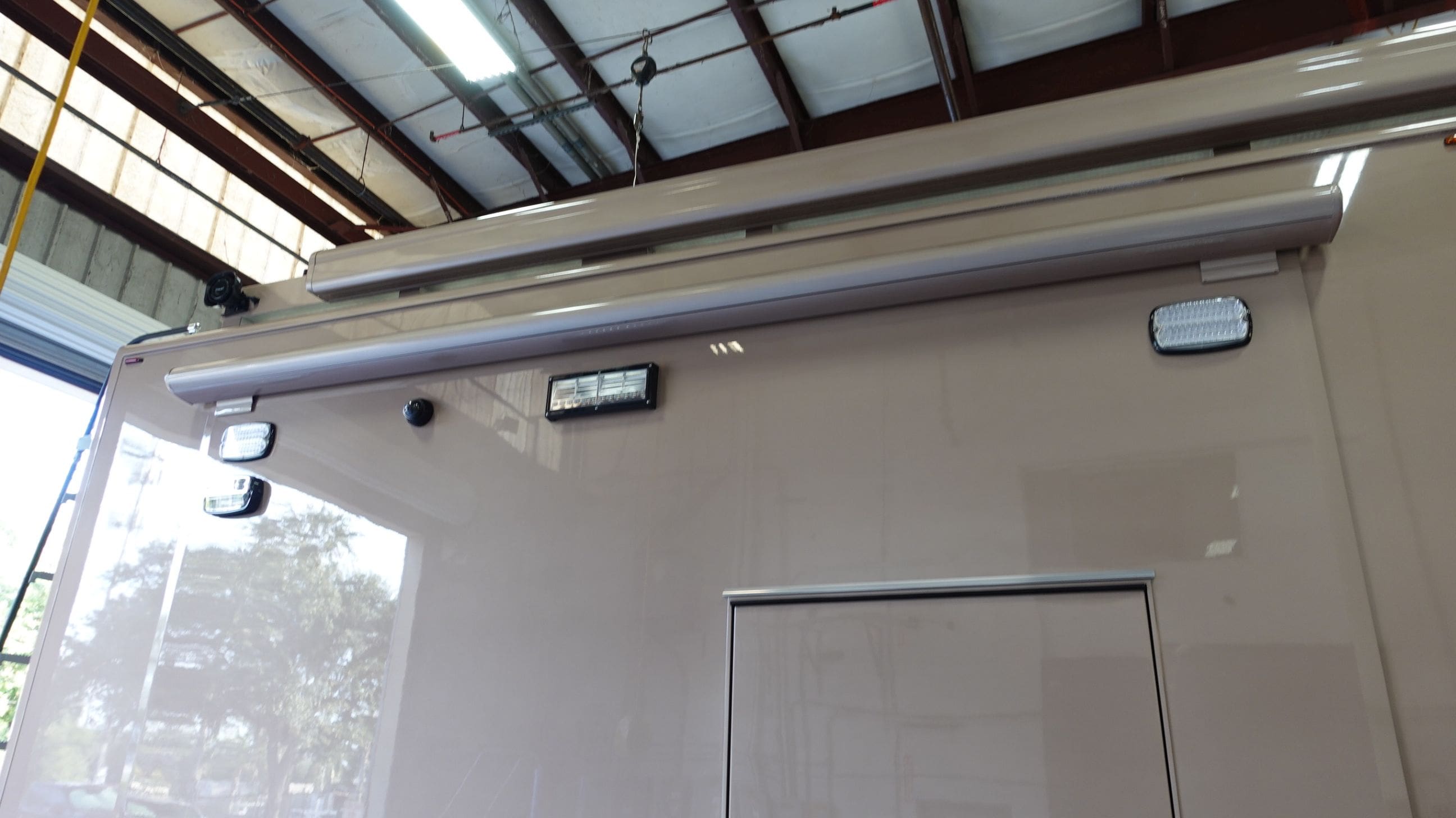

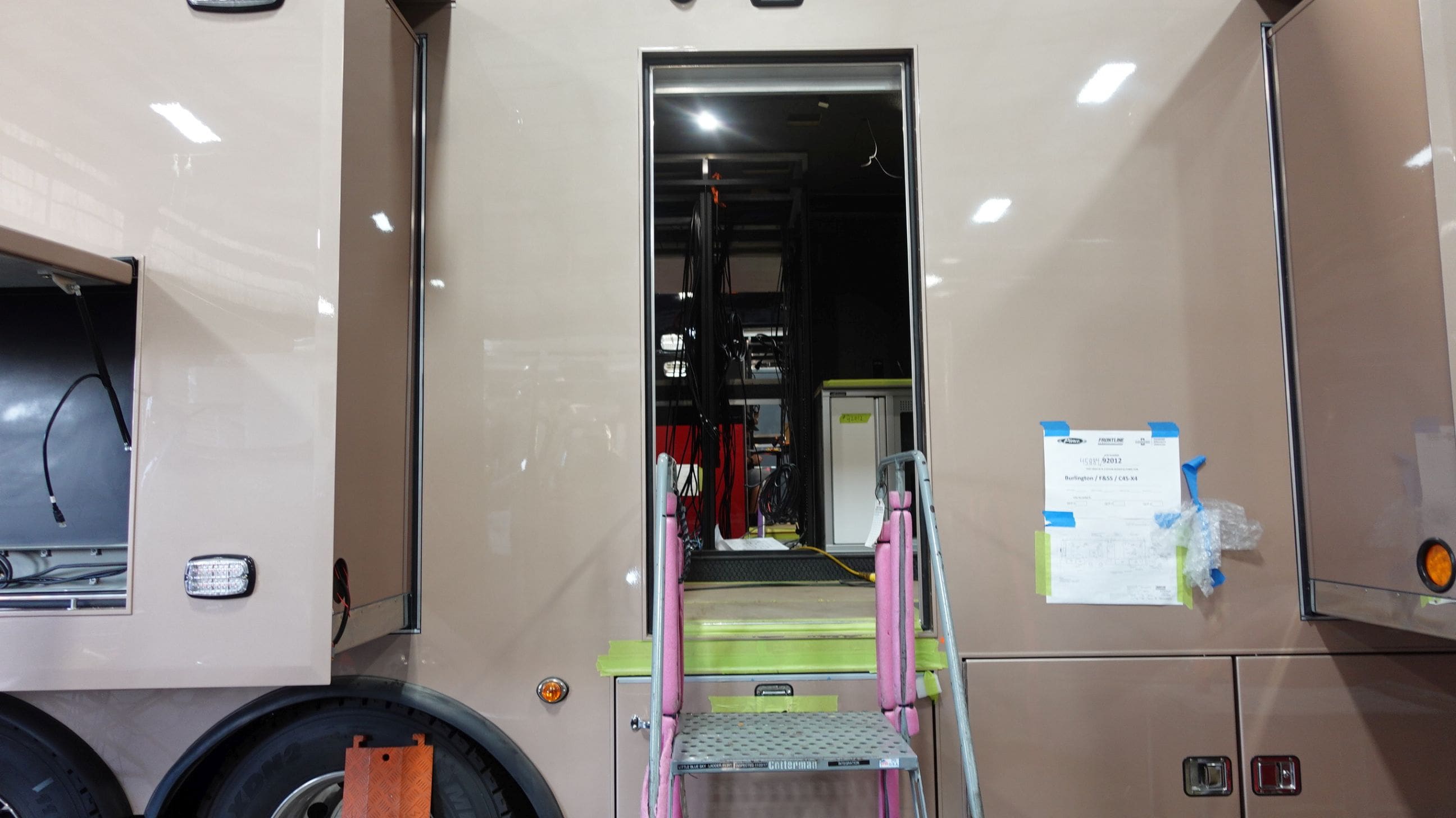

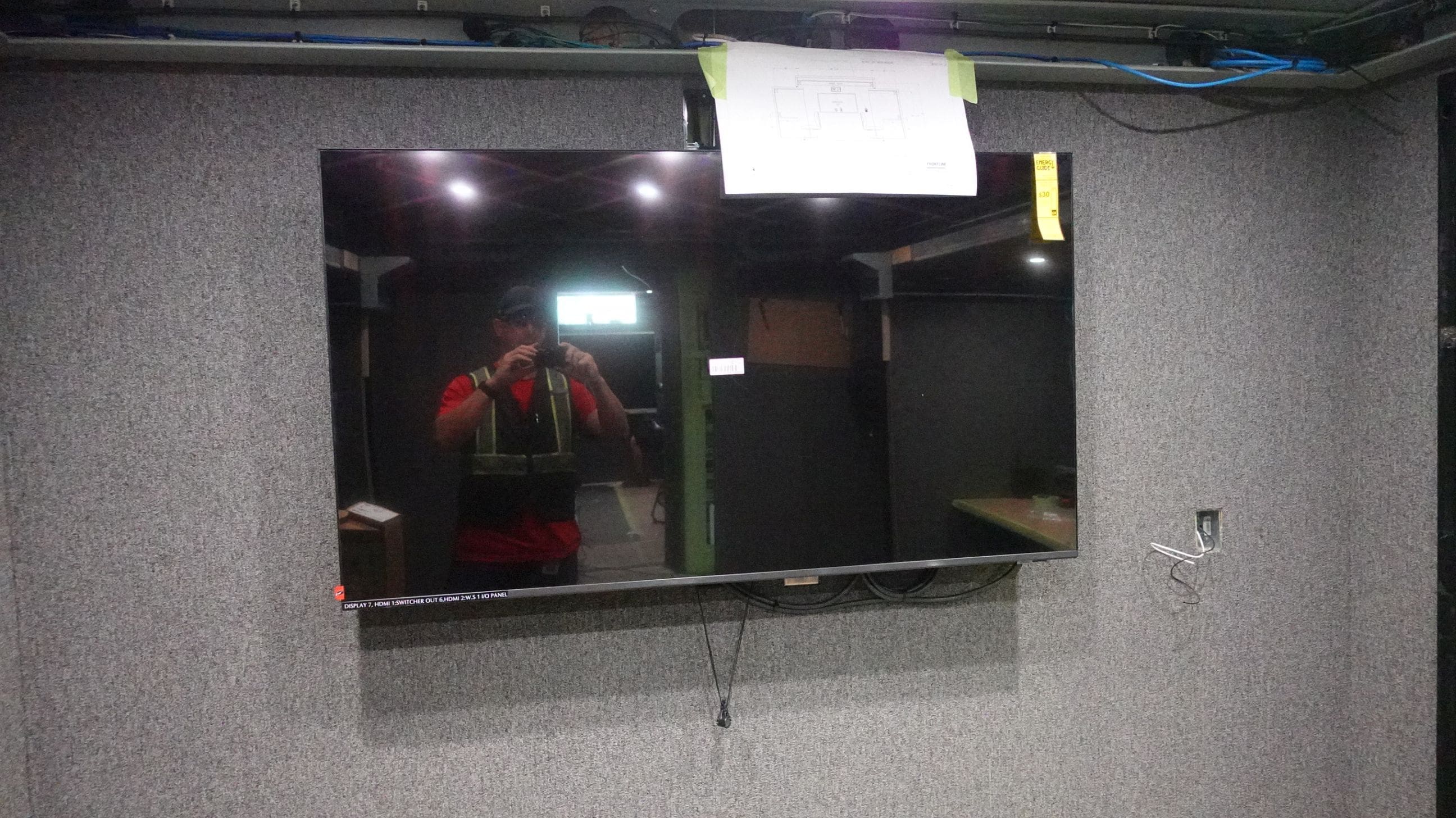

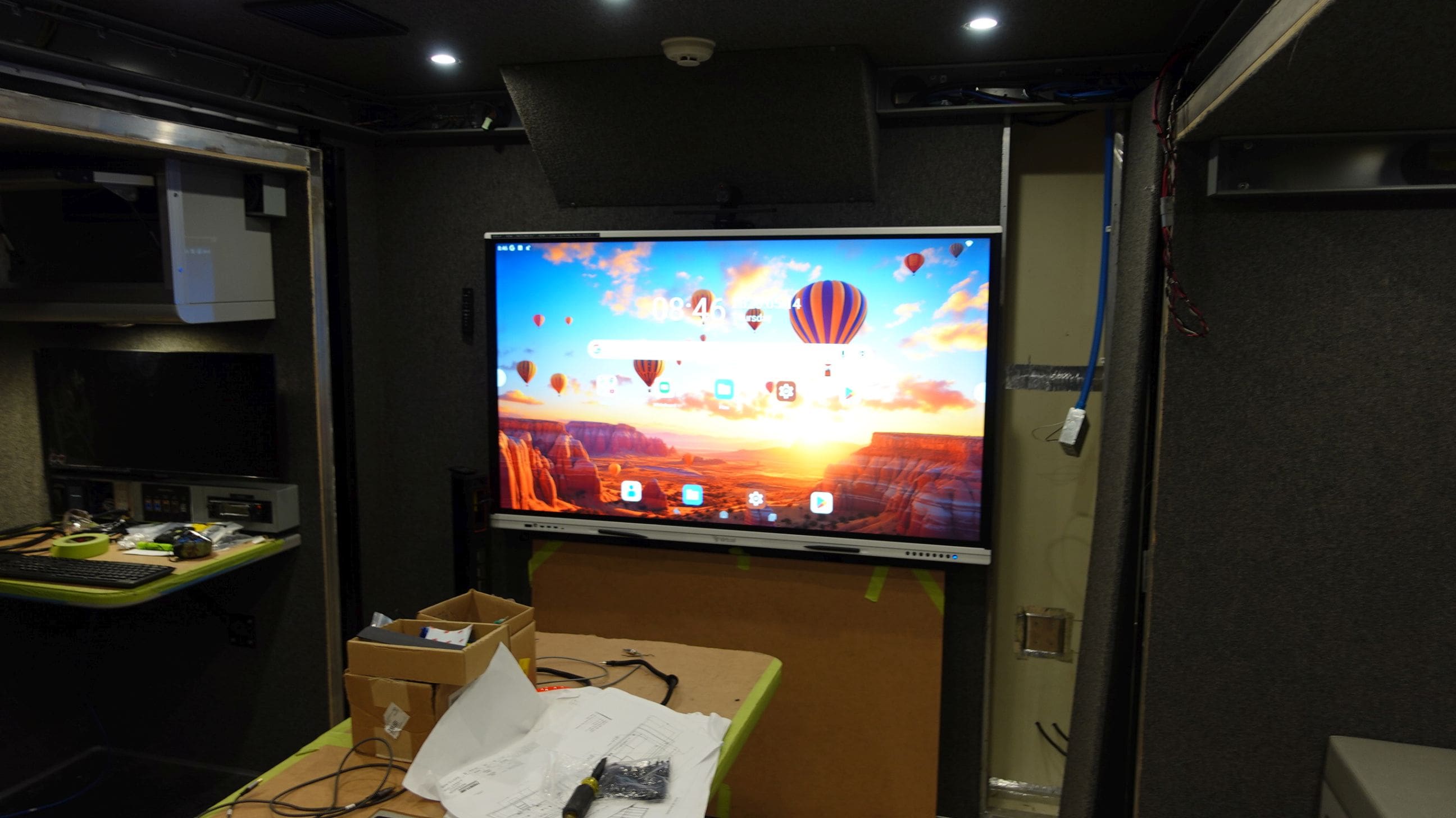

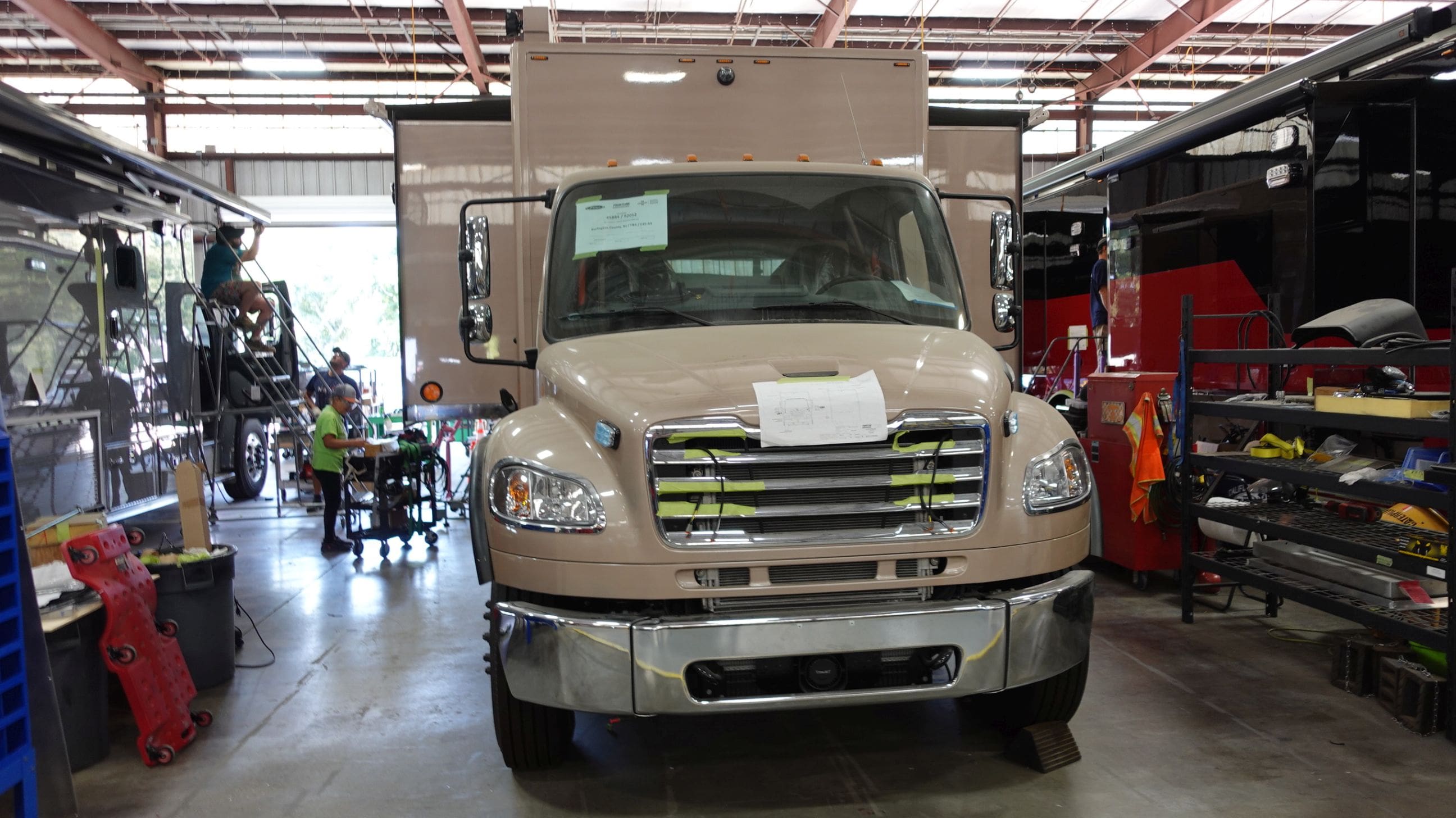

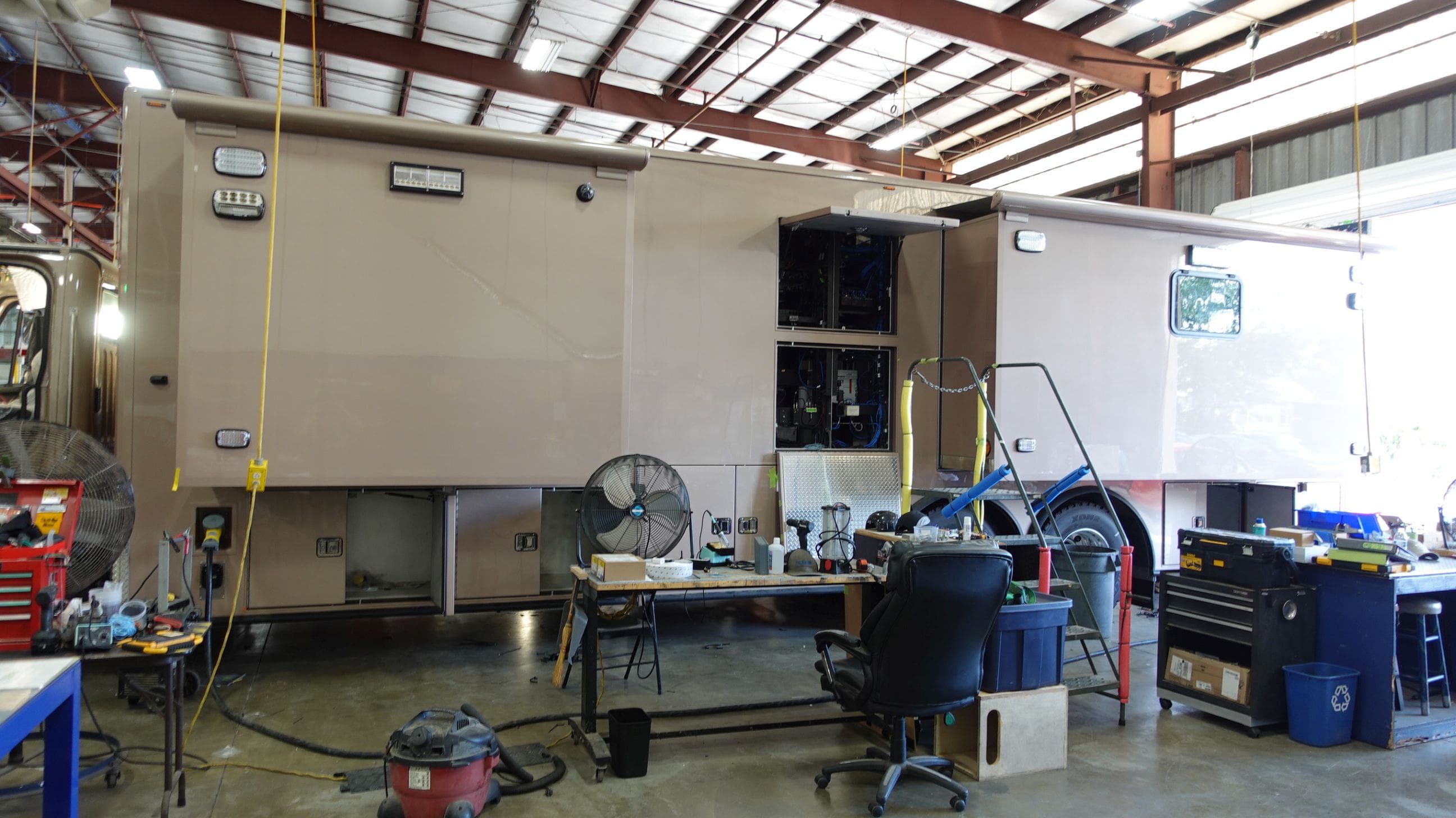

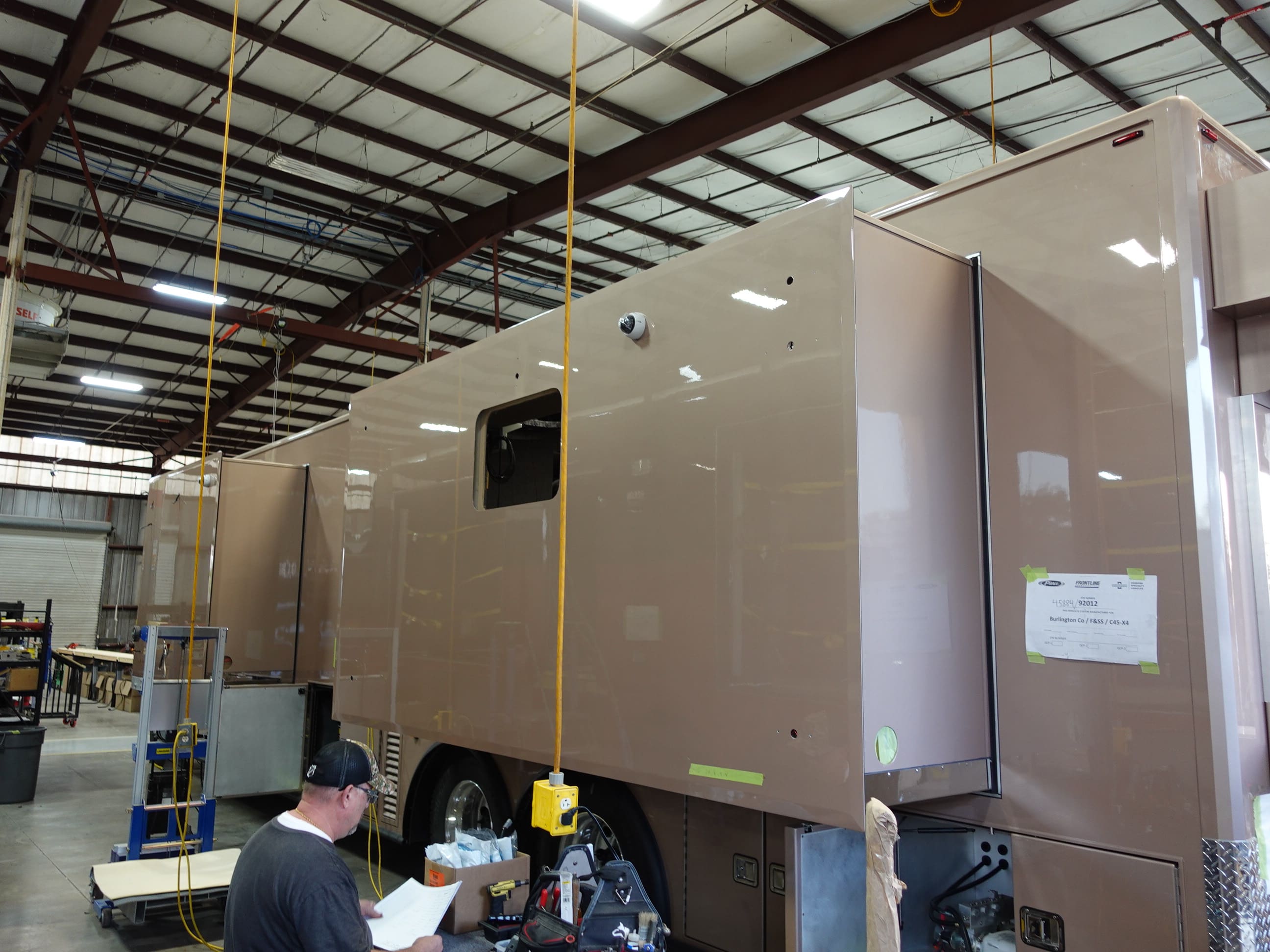

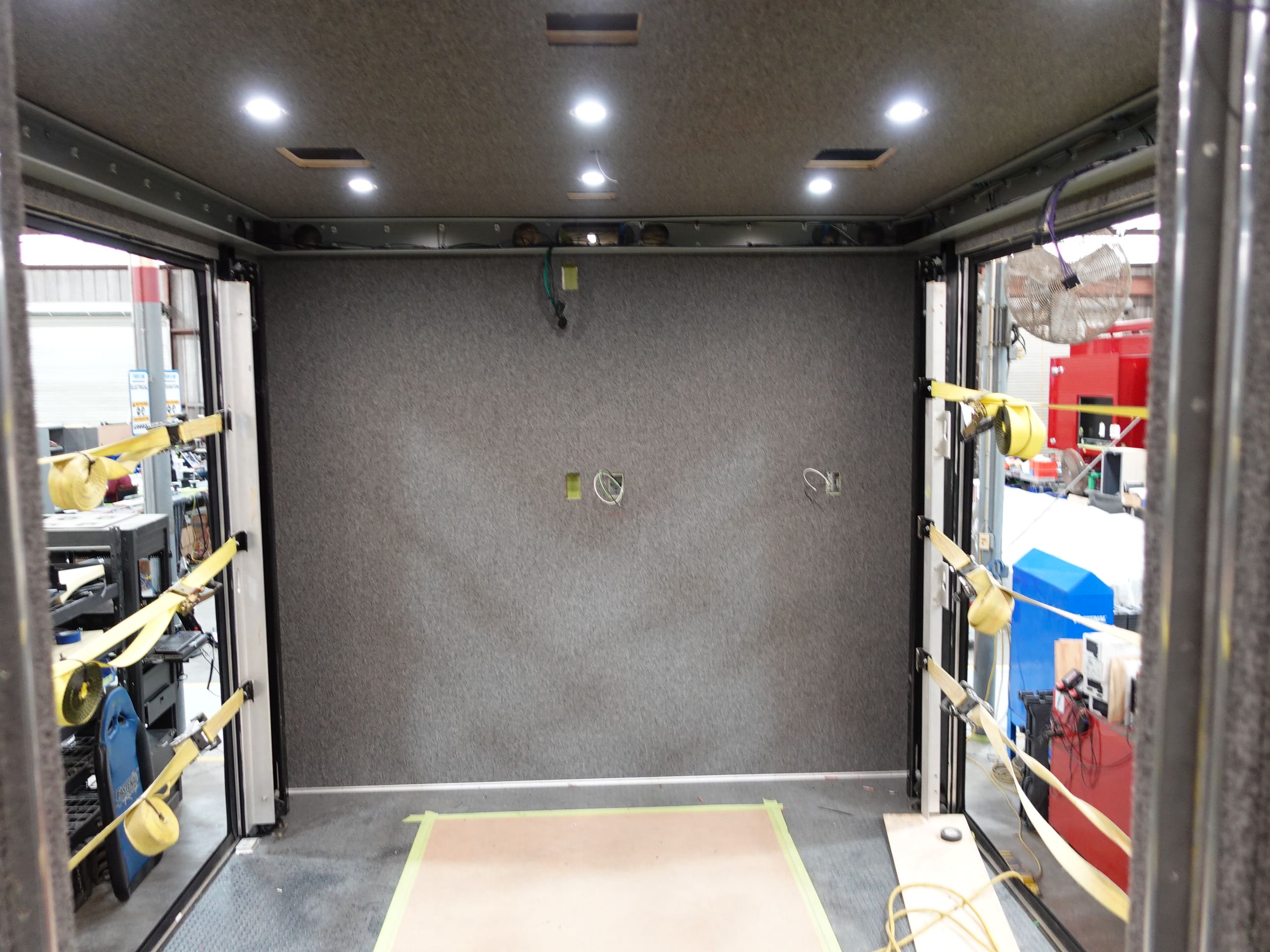

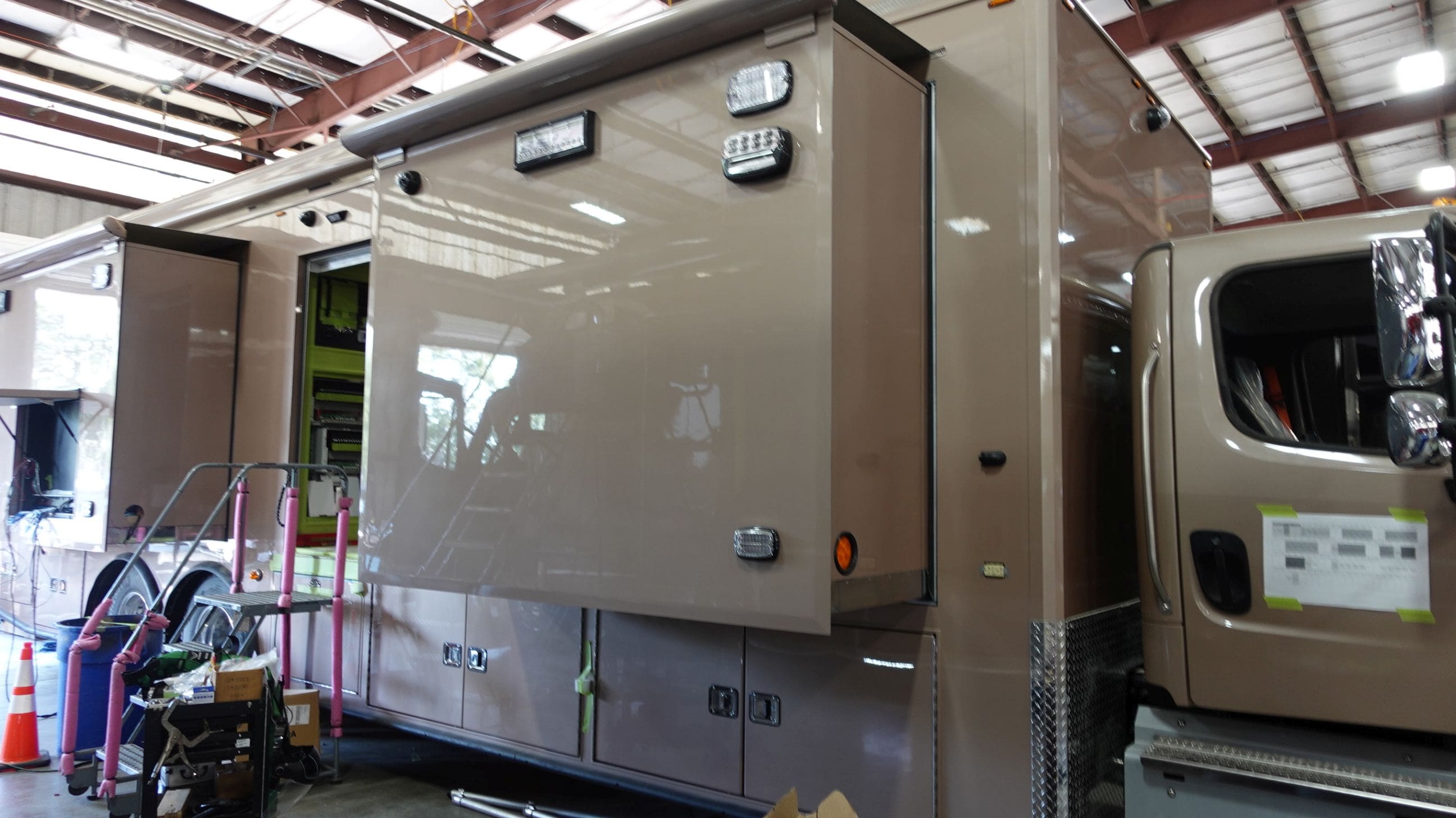

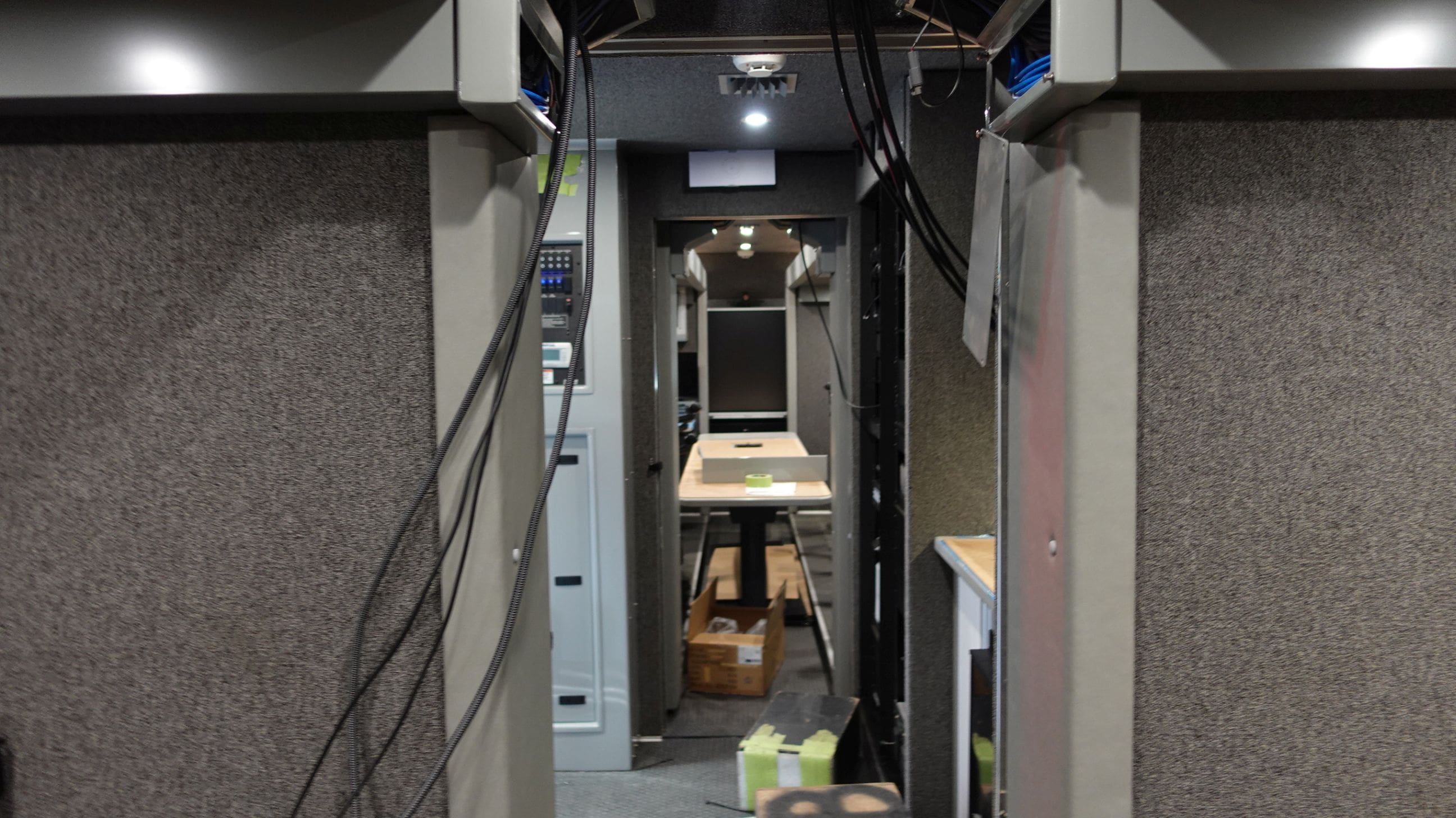

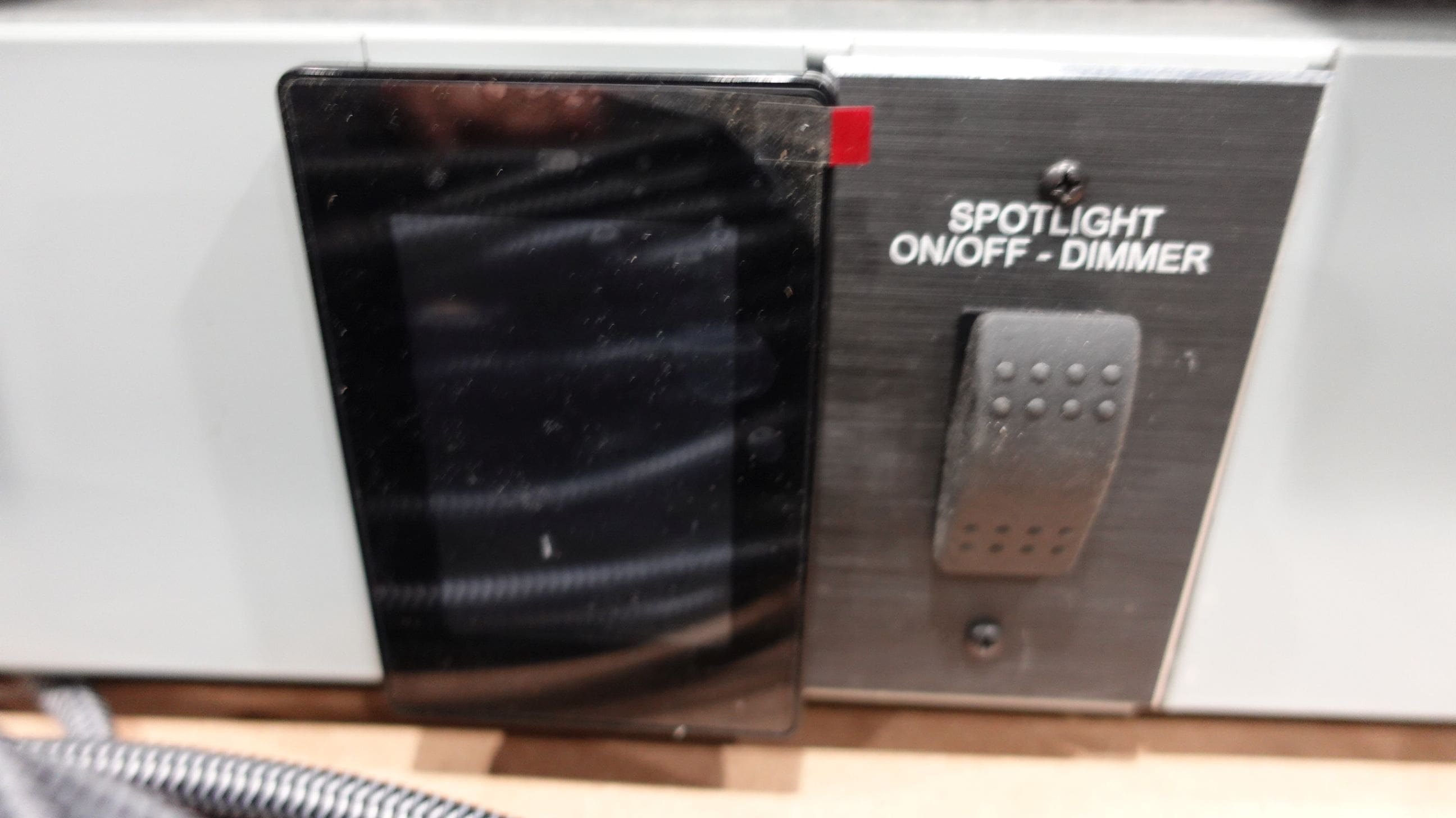

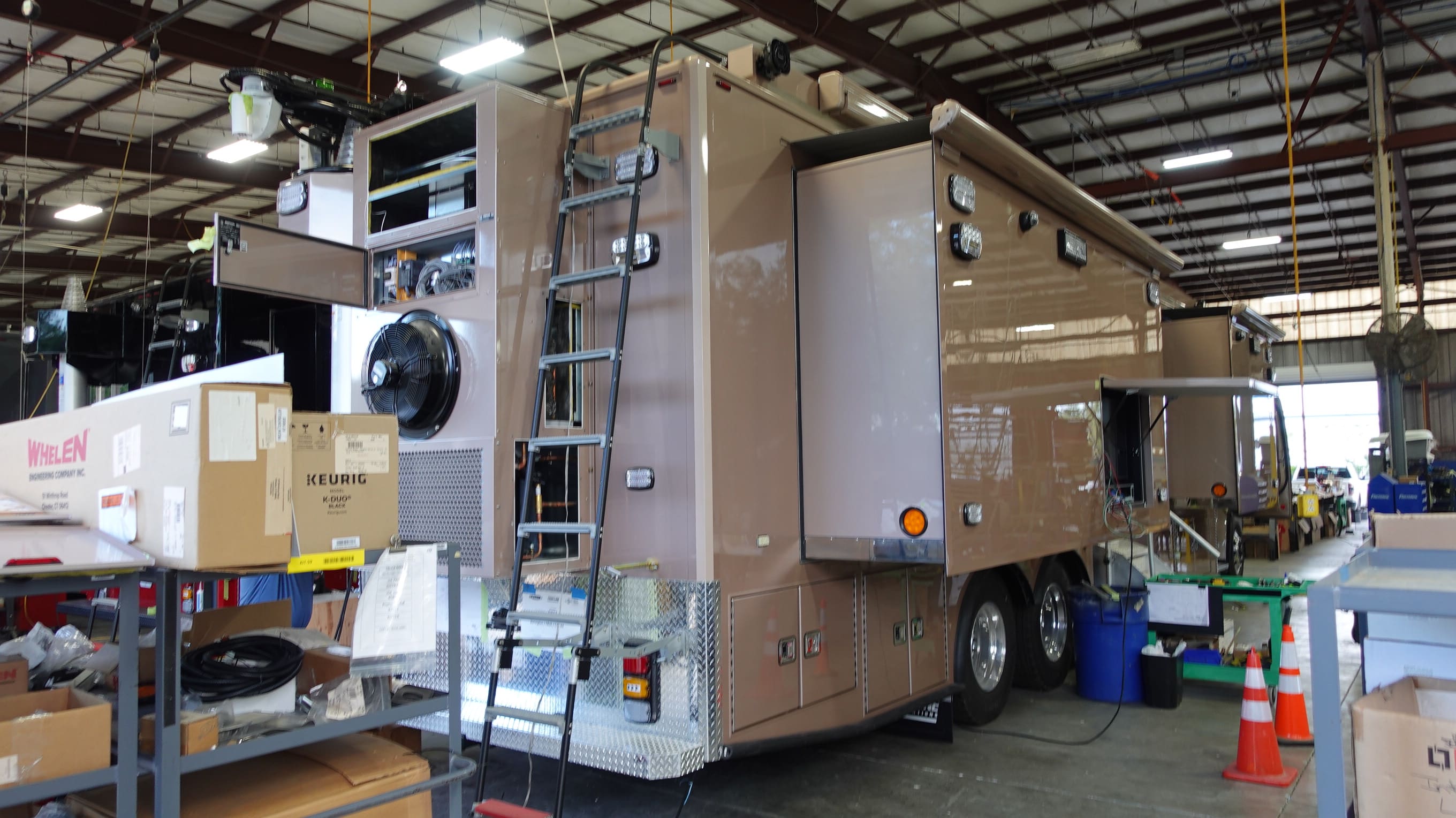

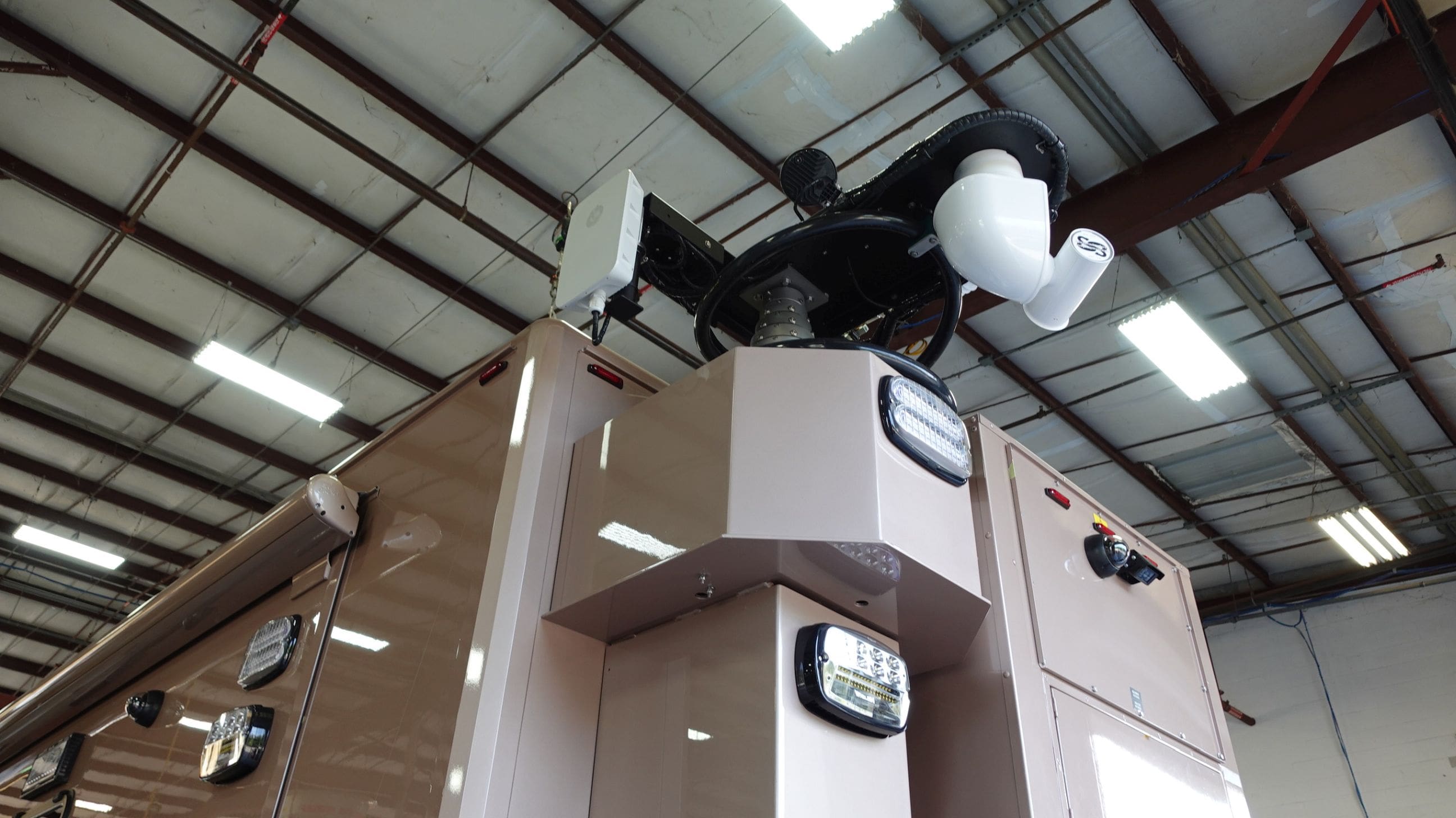

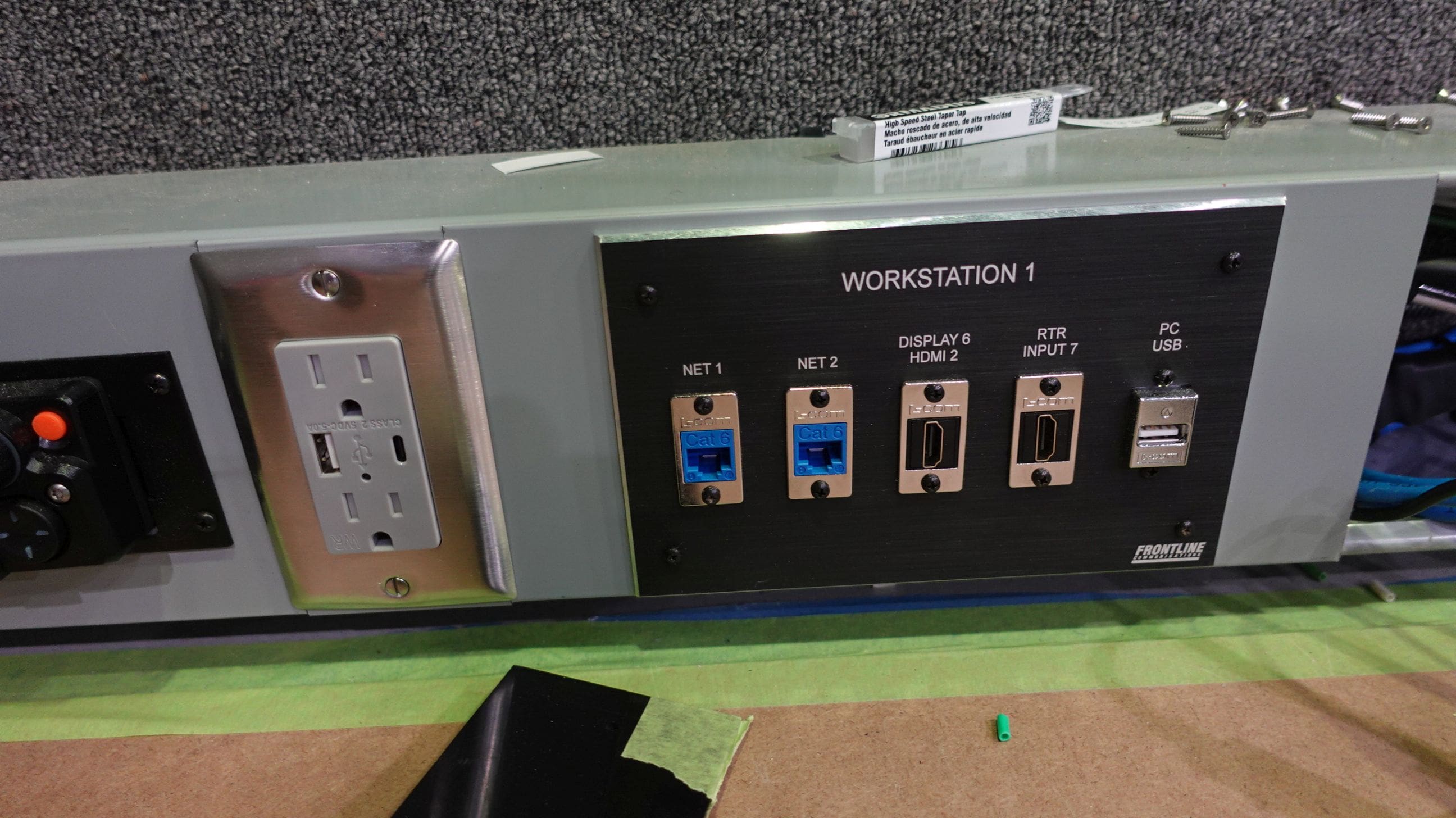

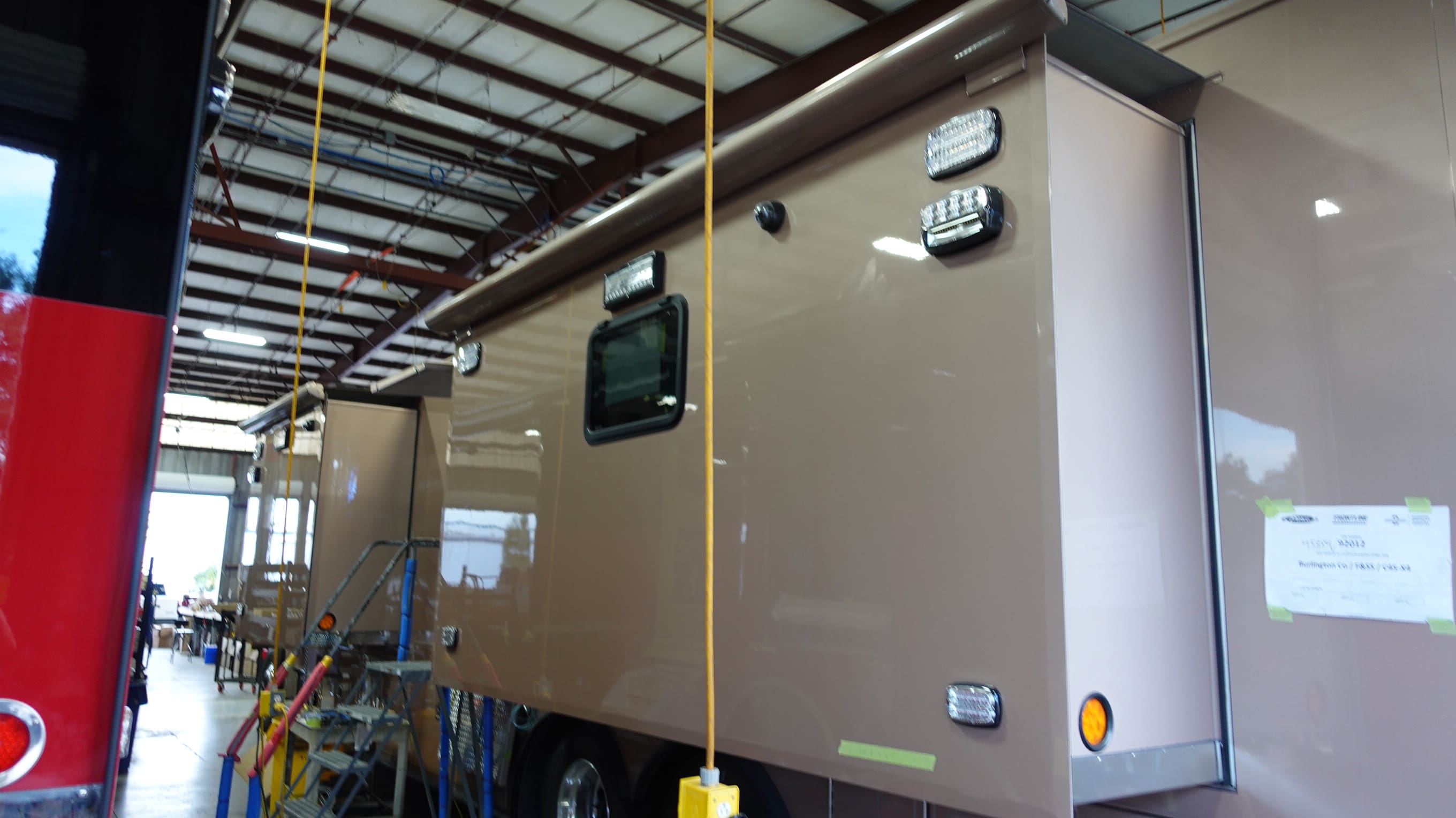

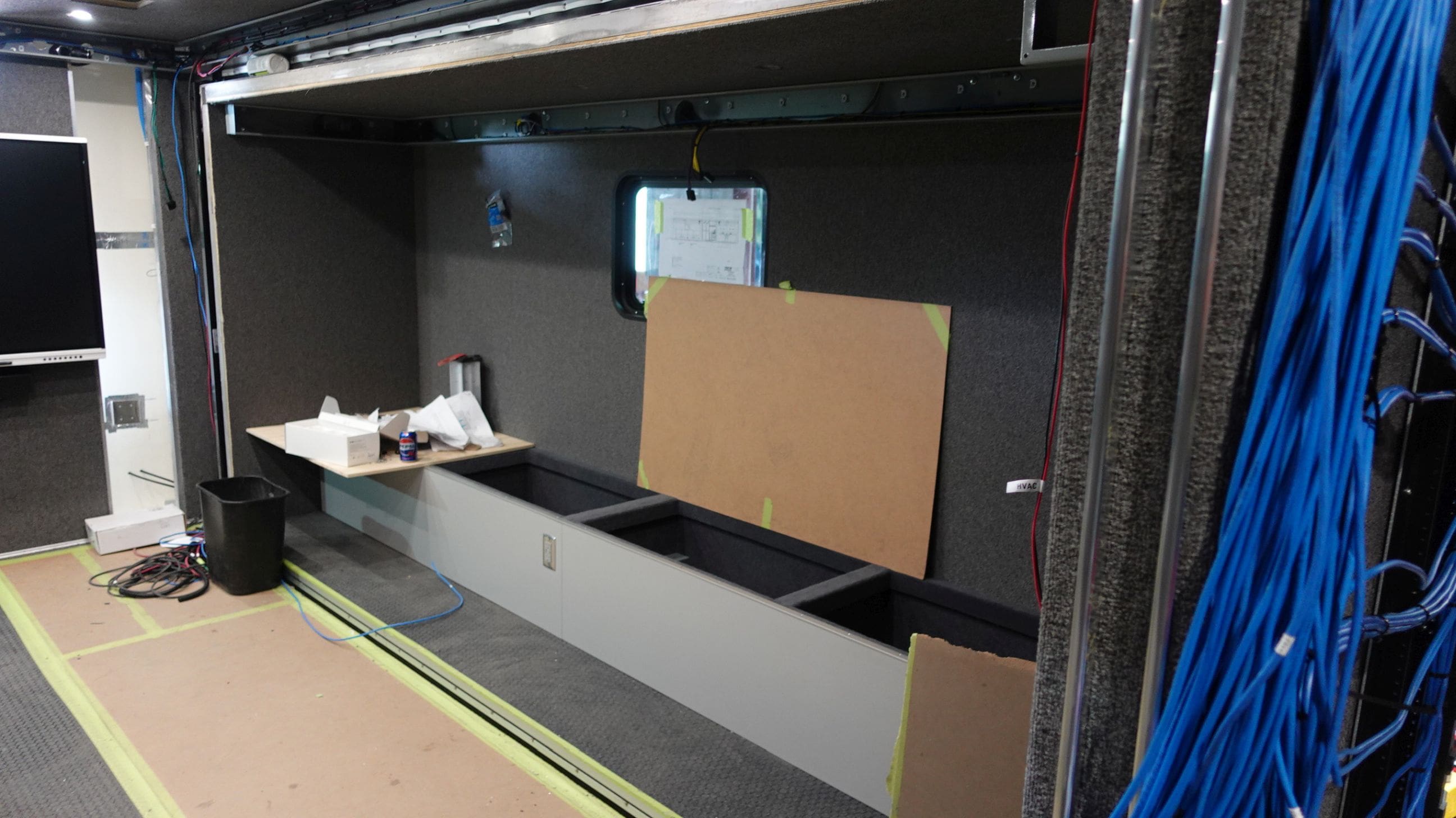

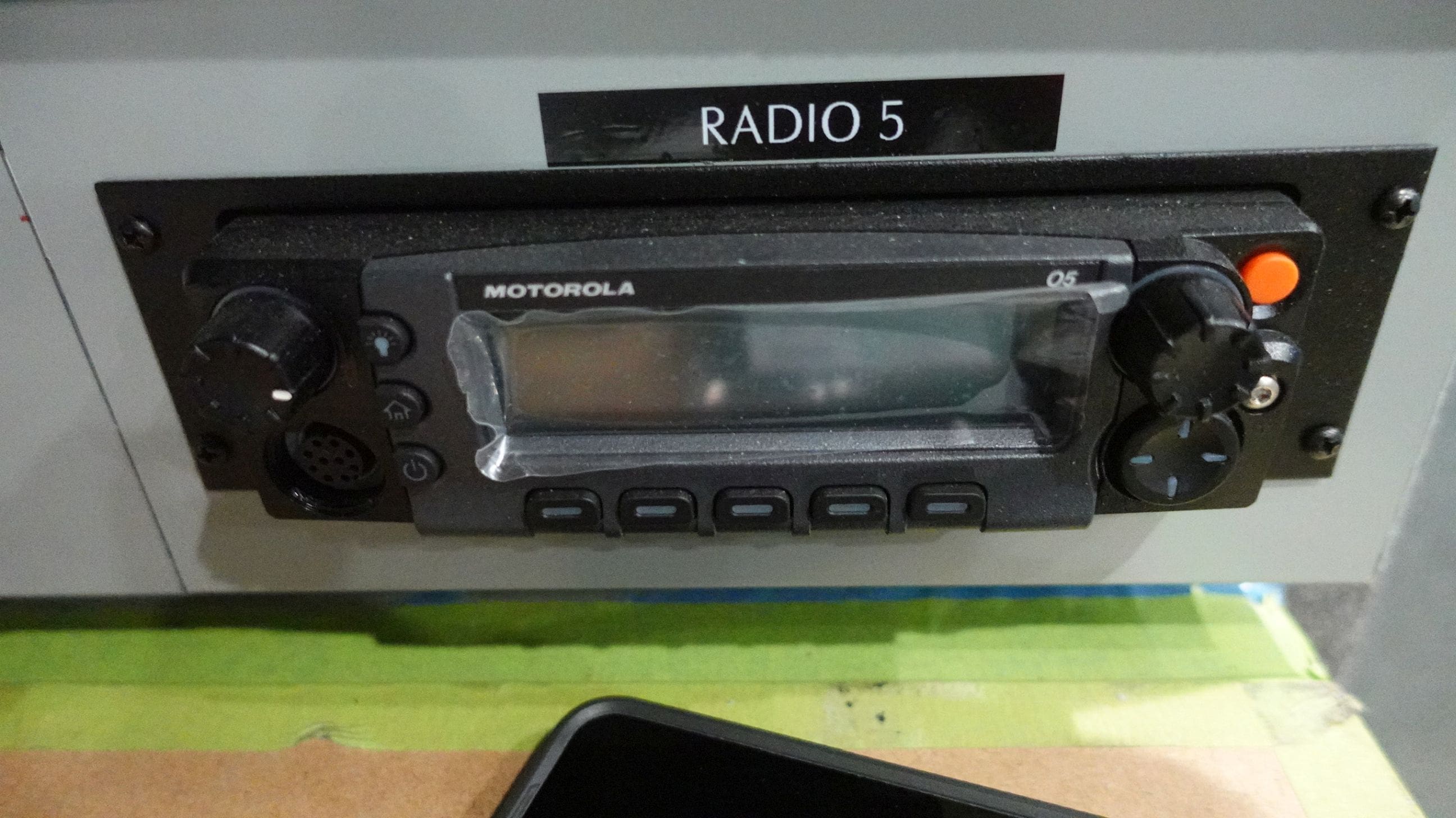

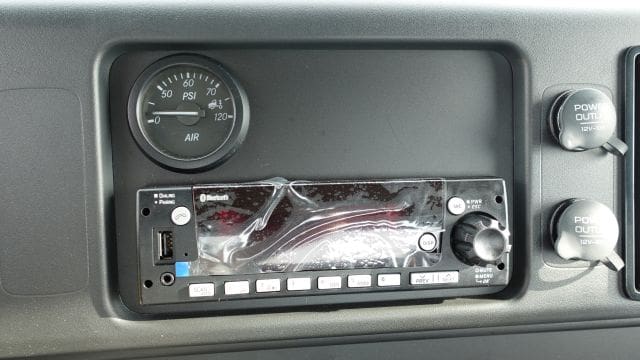

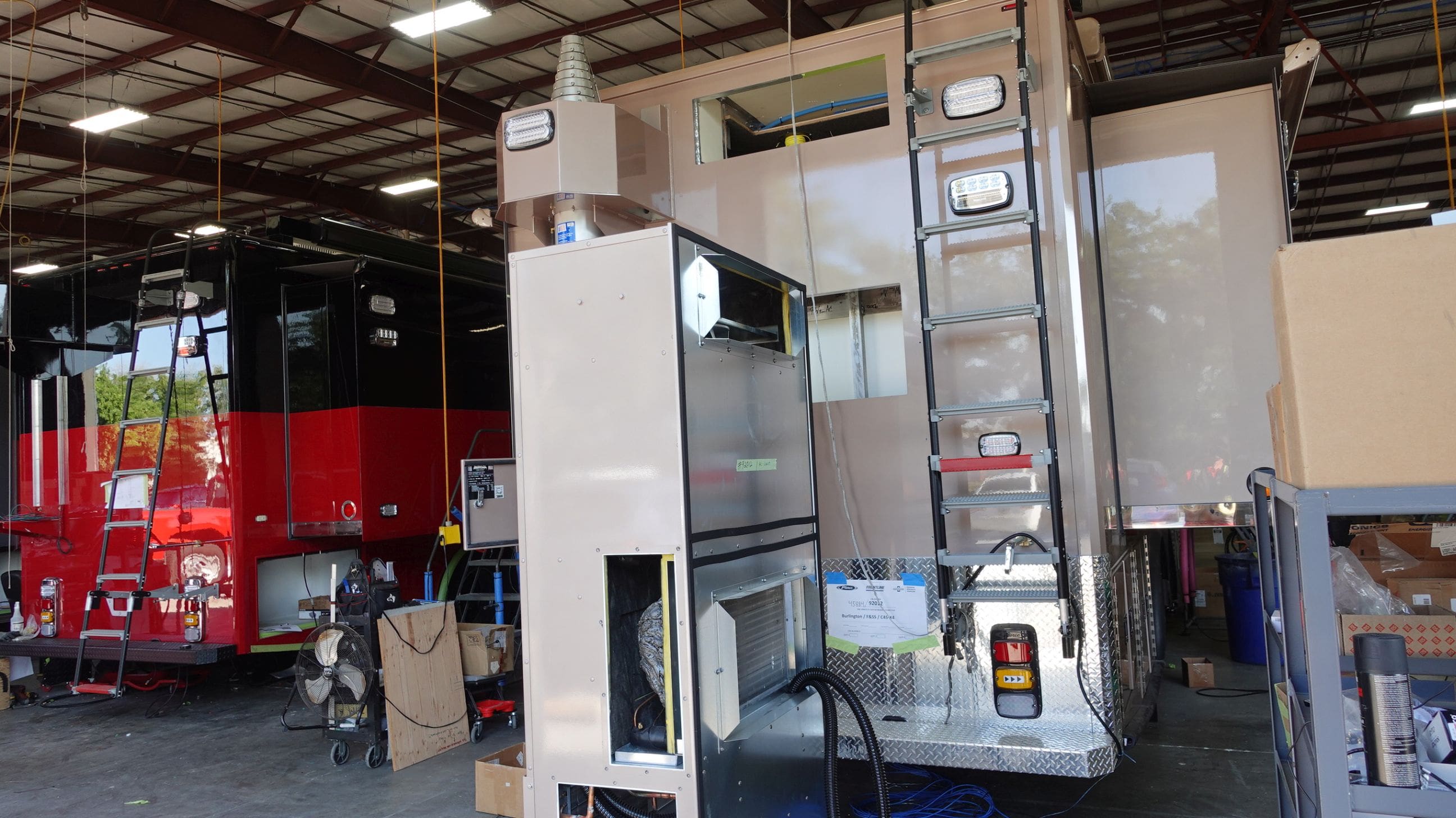

inspection. This is the last scheduled report.

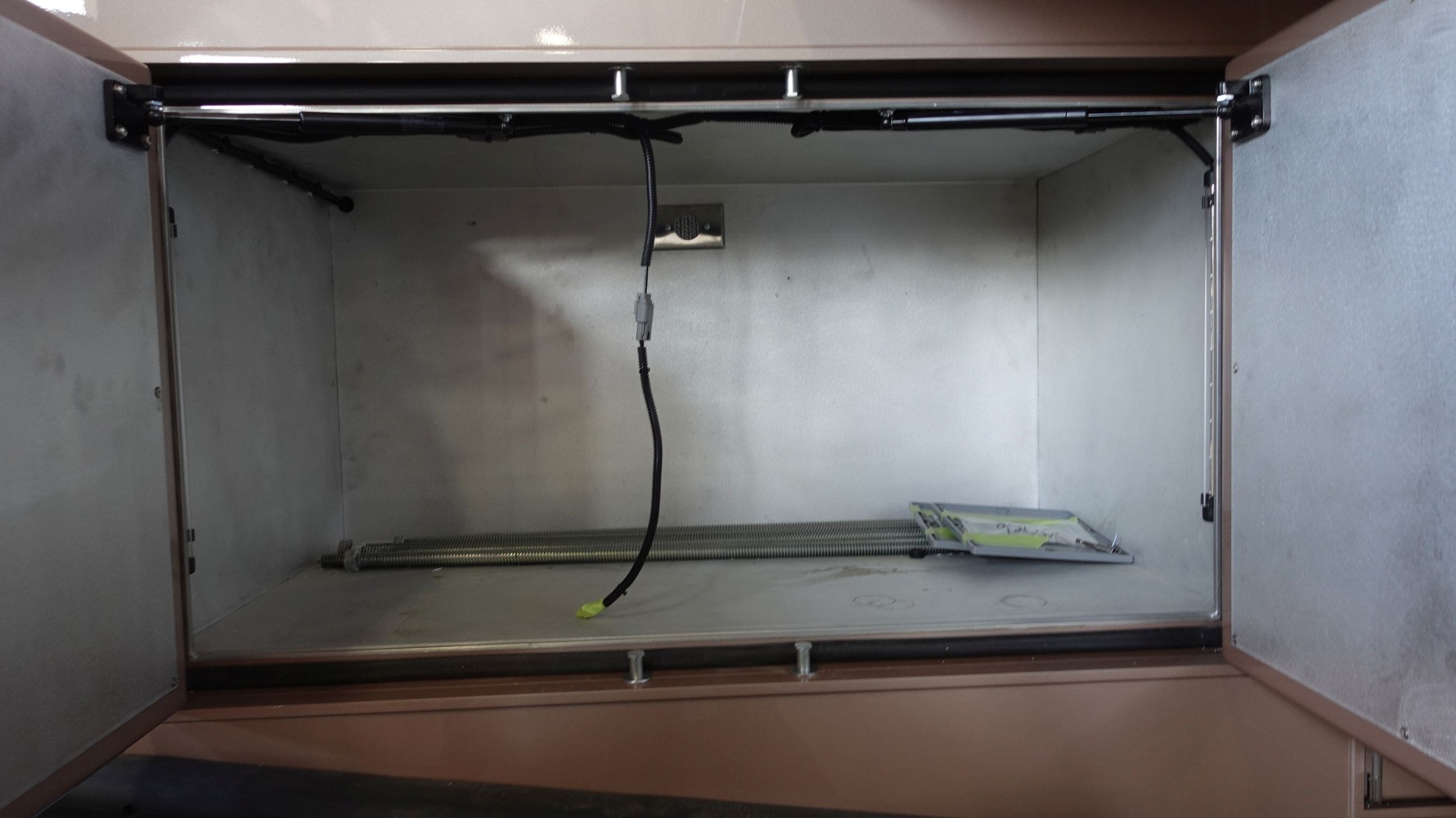

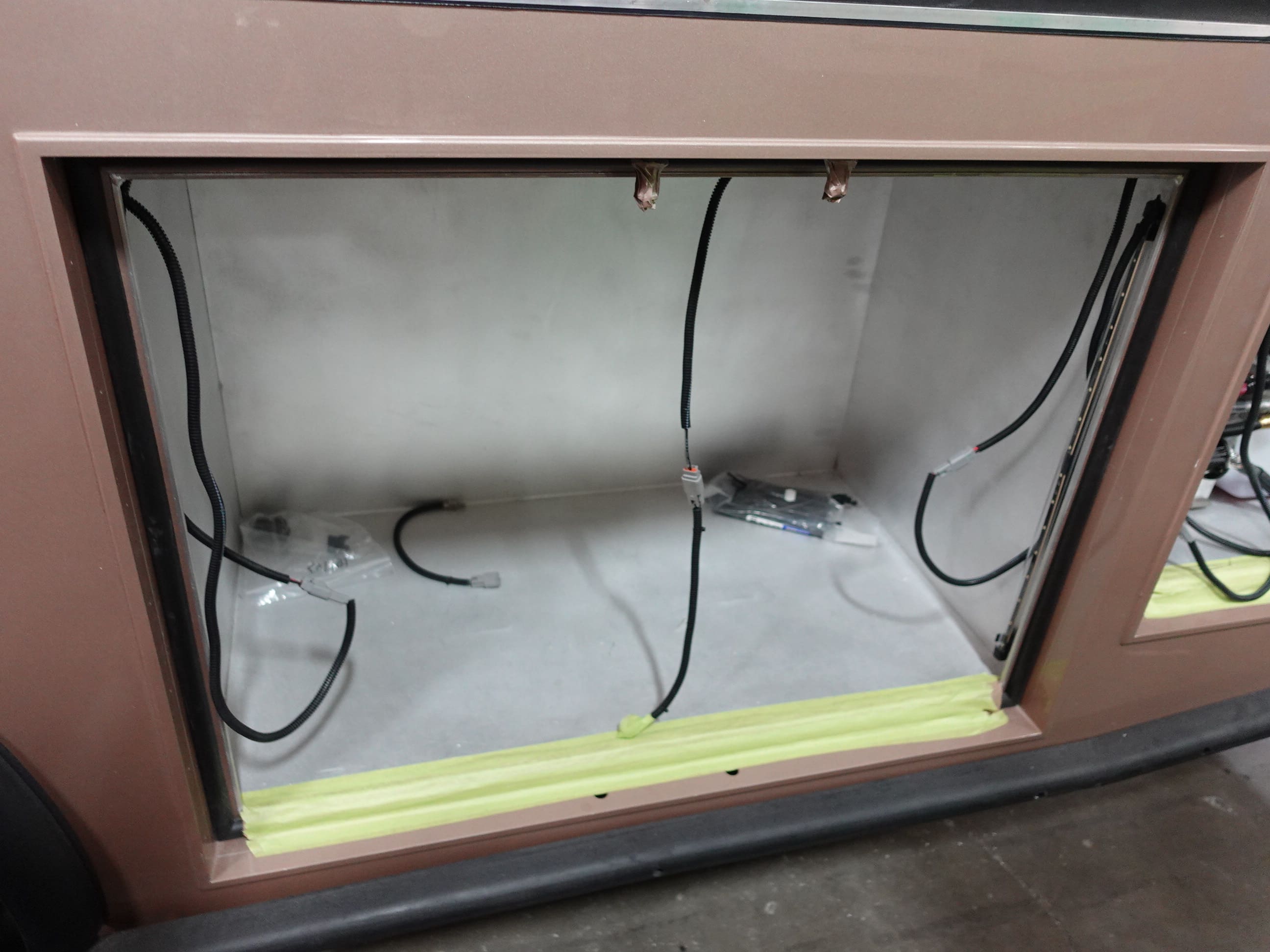

05-15-26

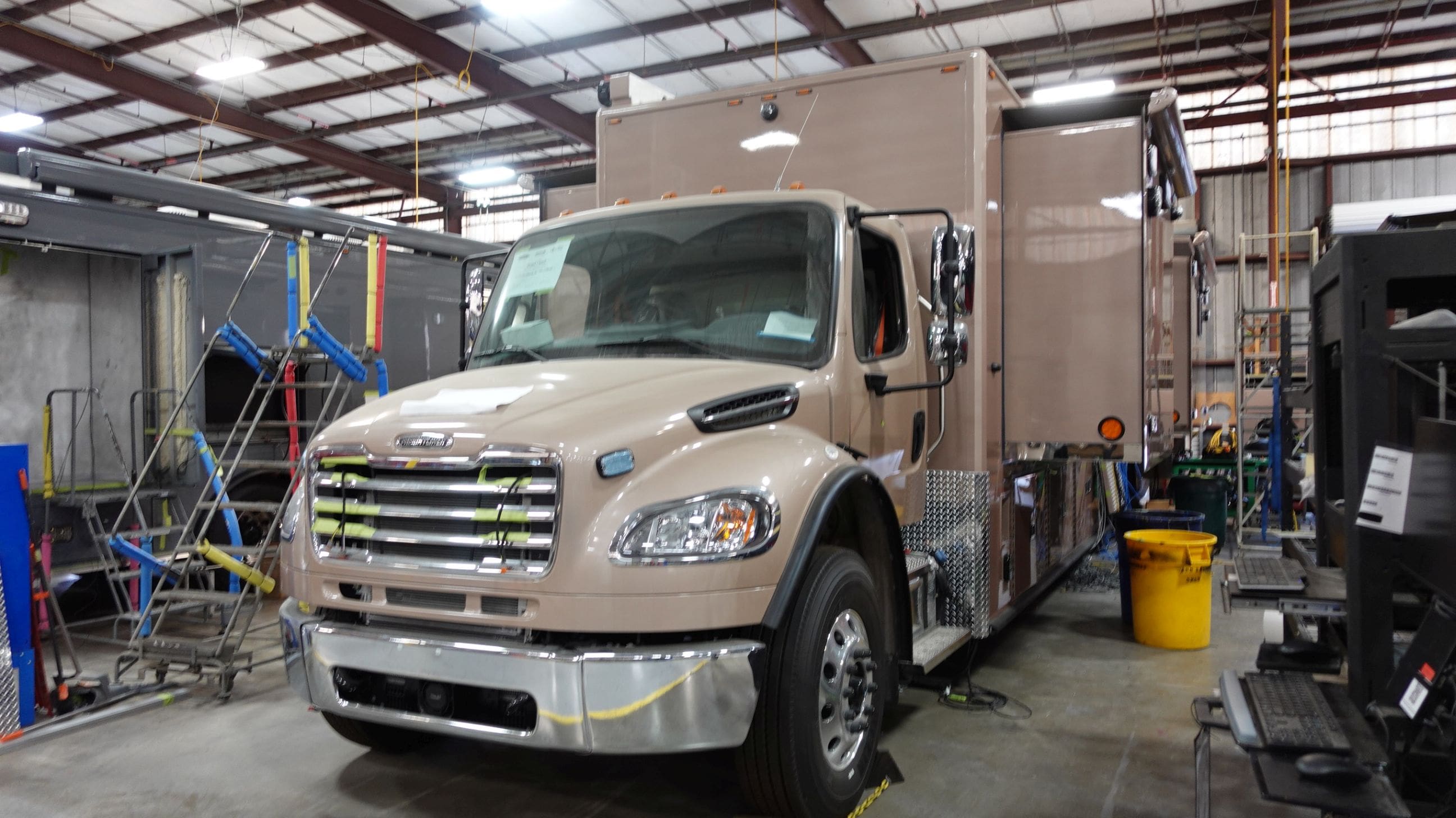

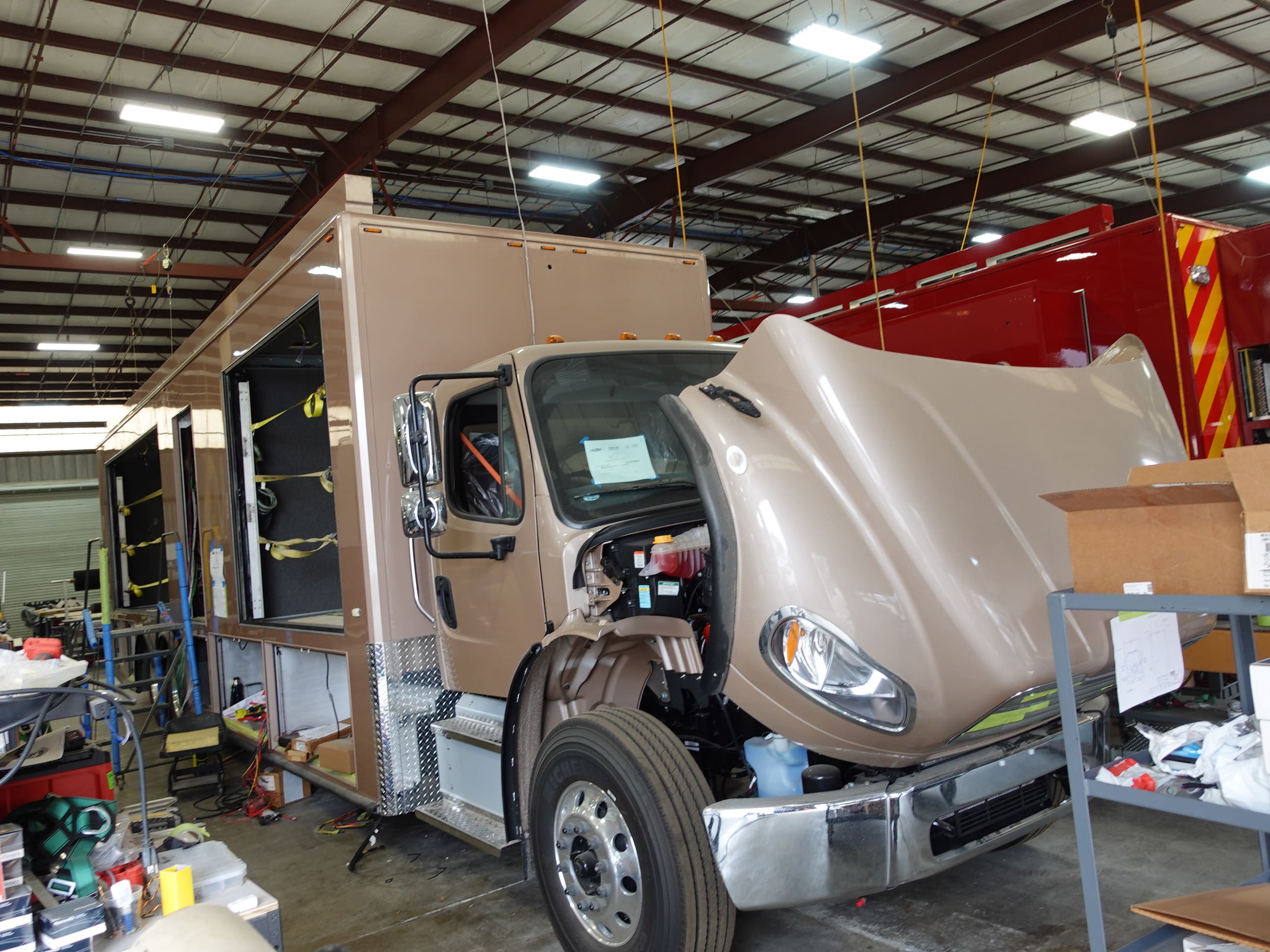

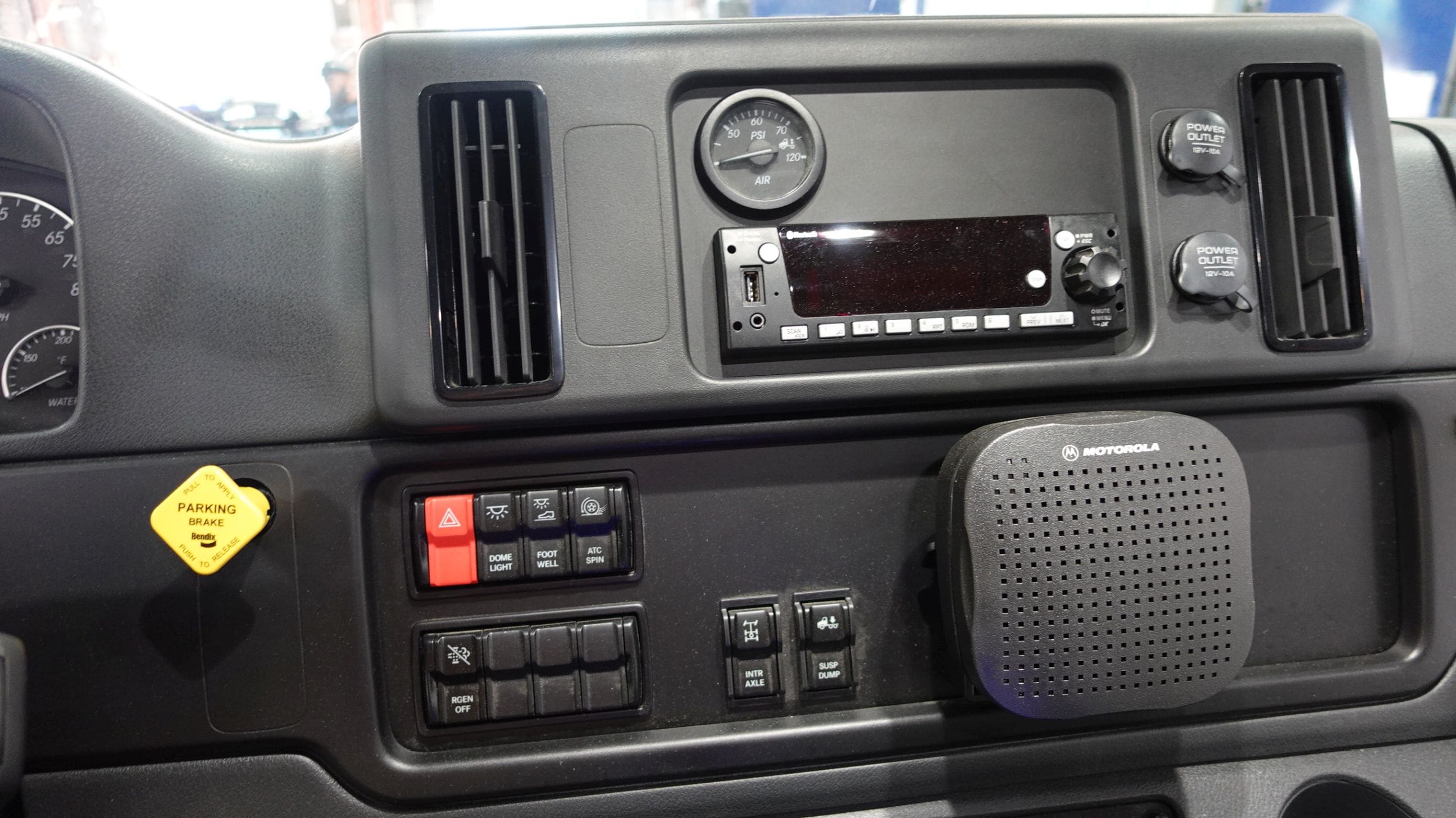

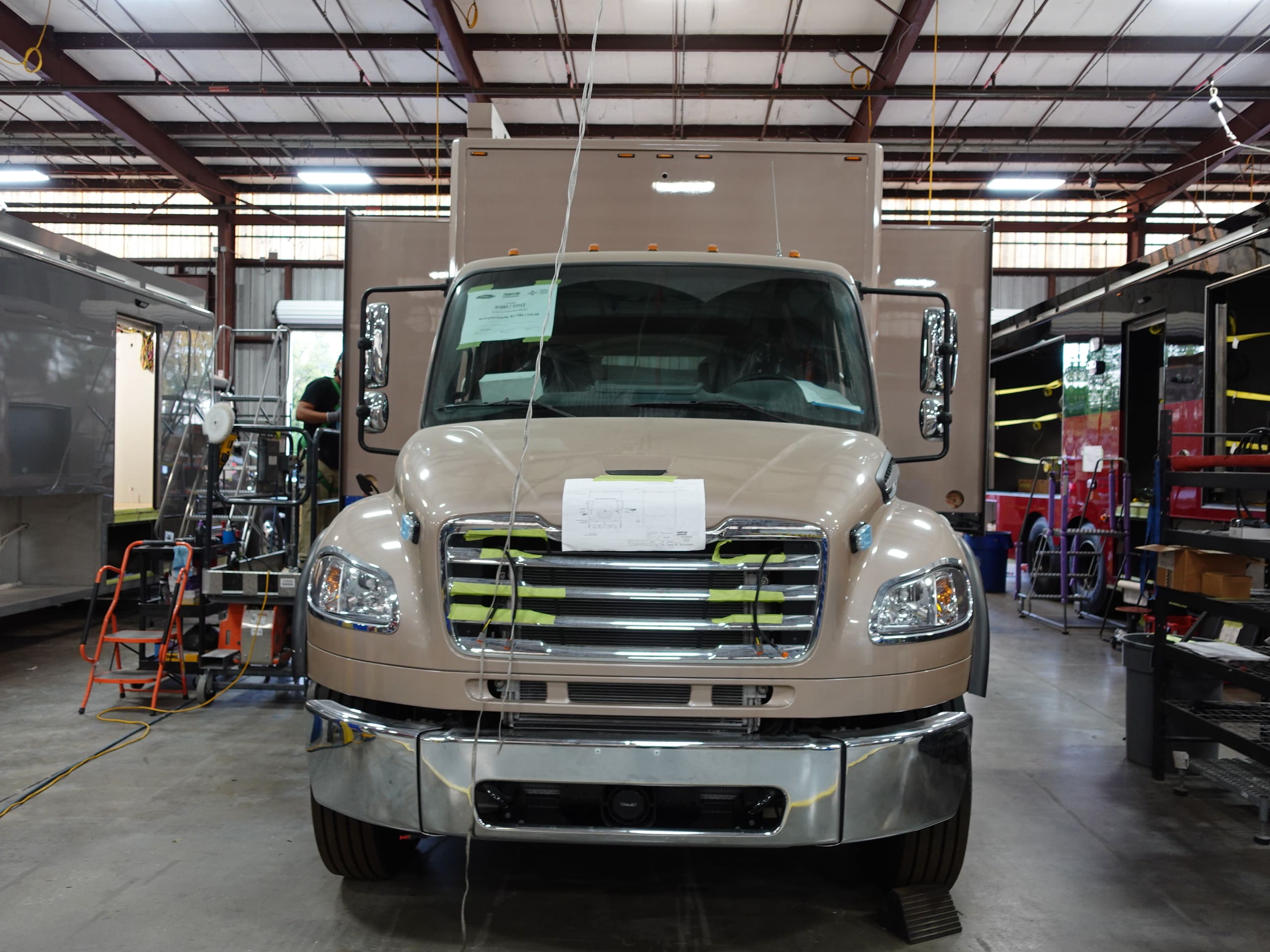

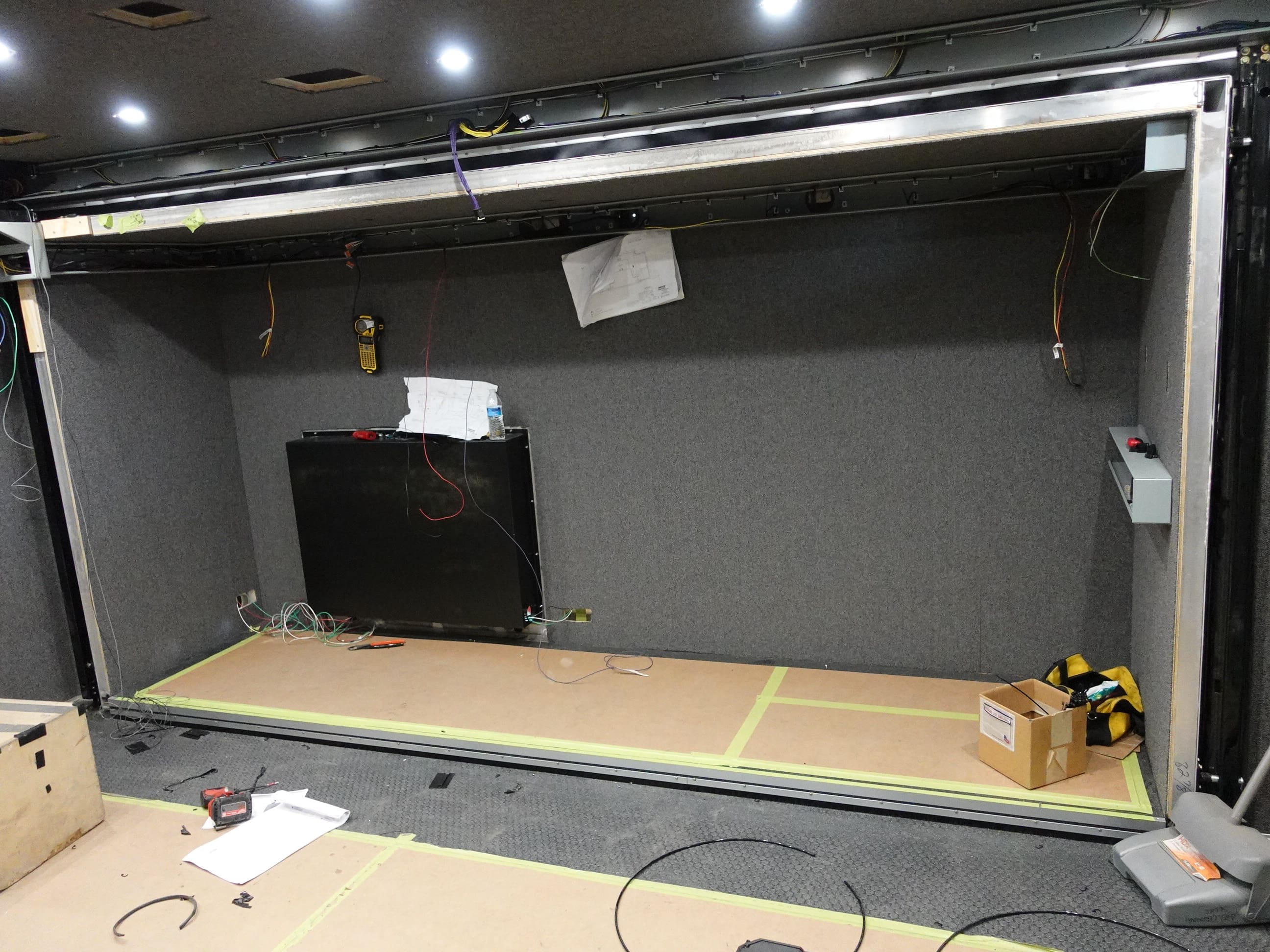

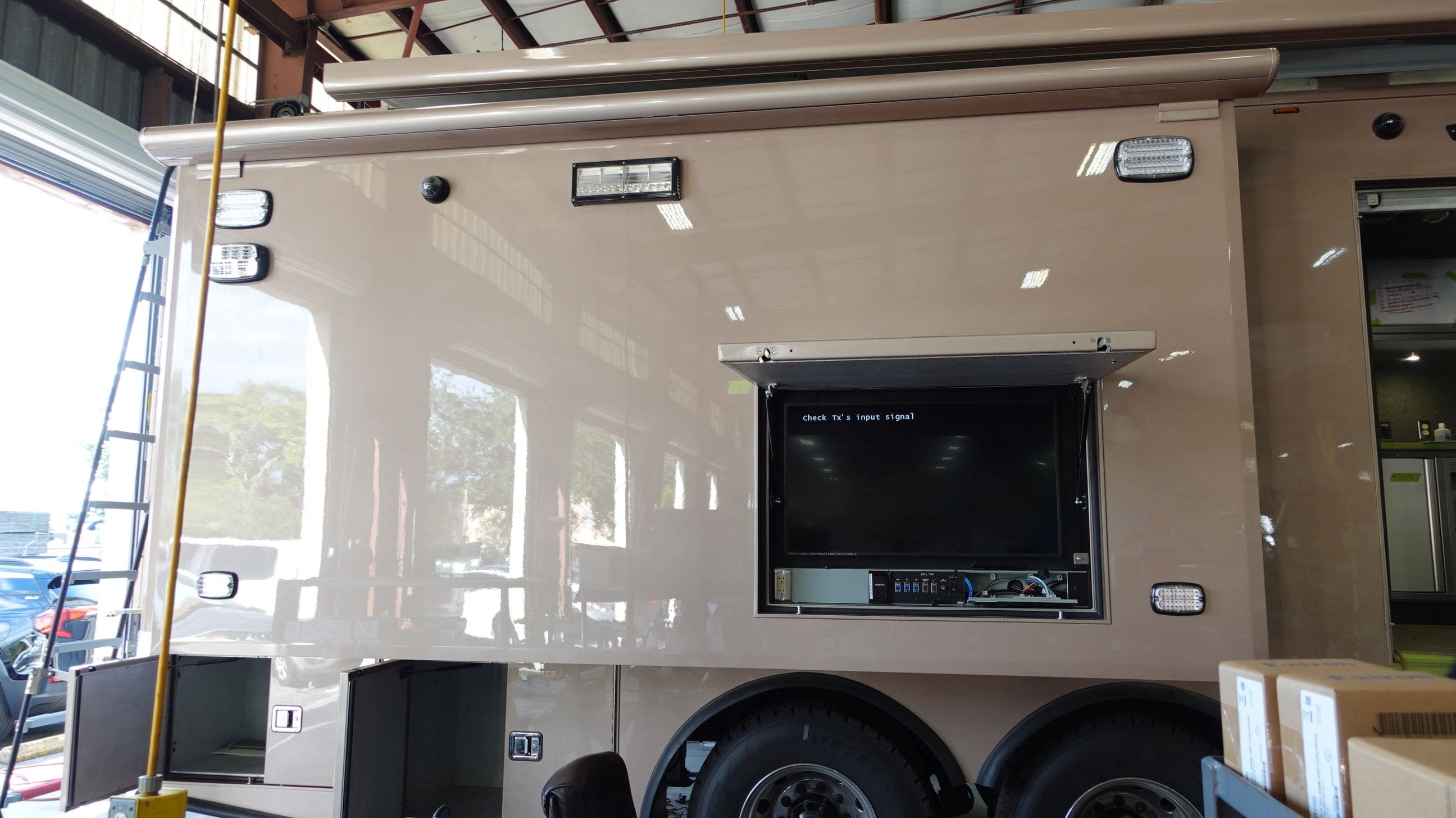

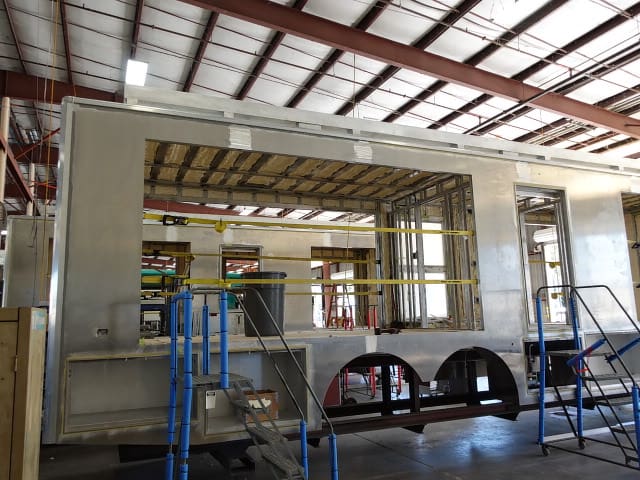

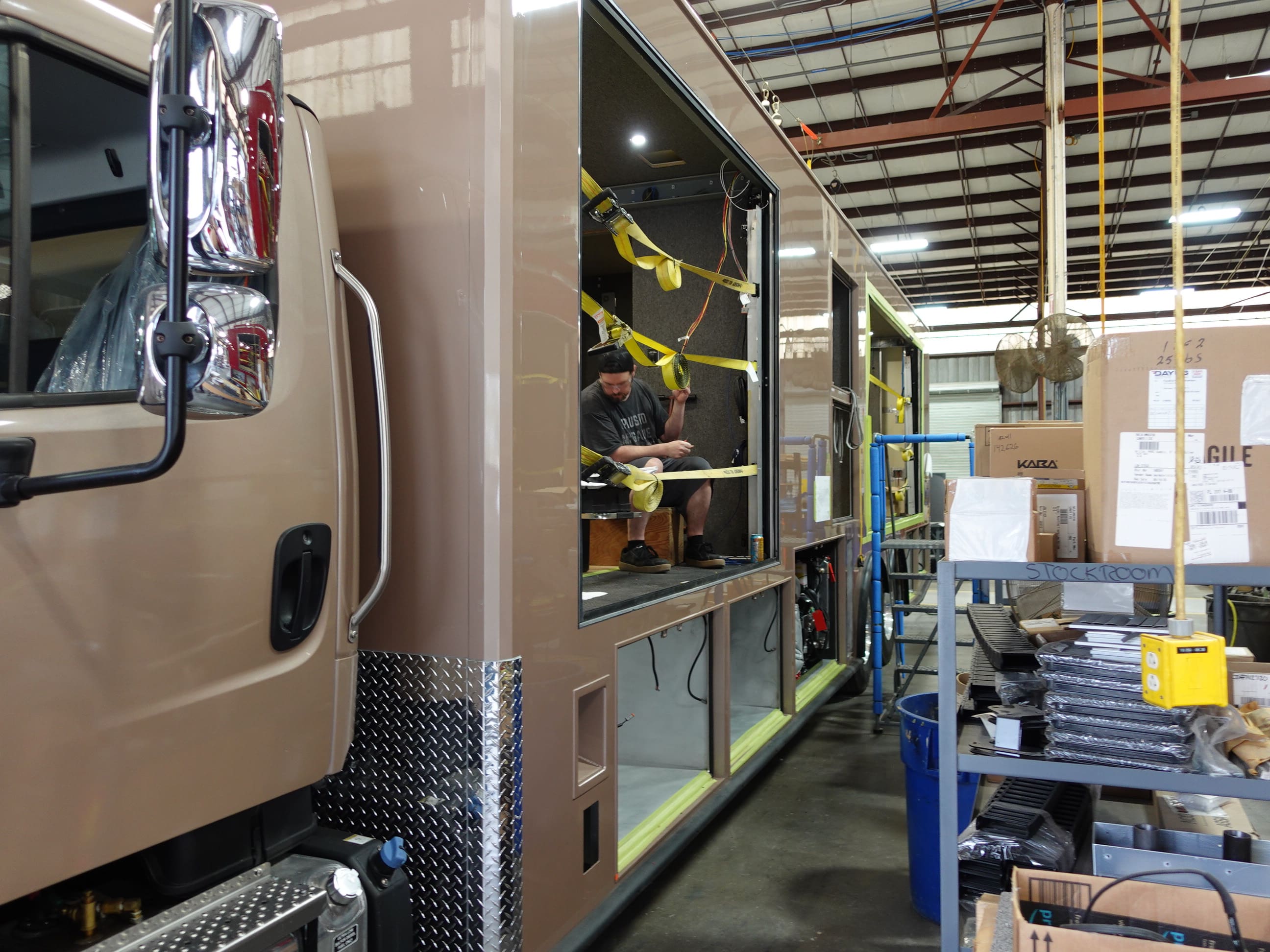

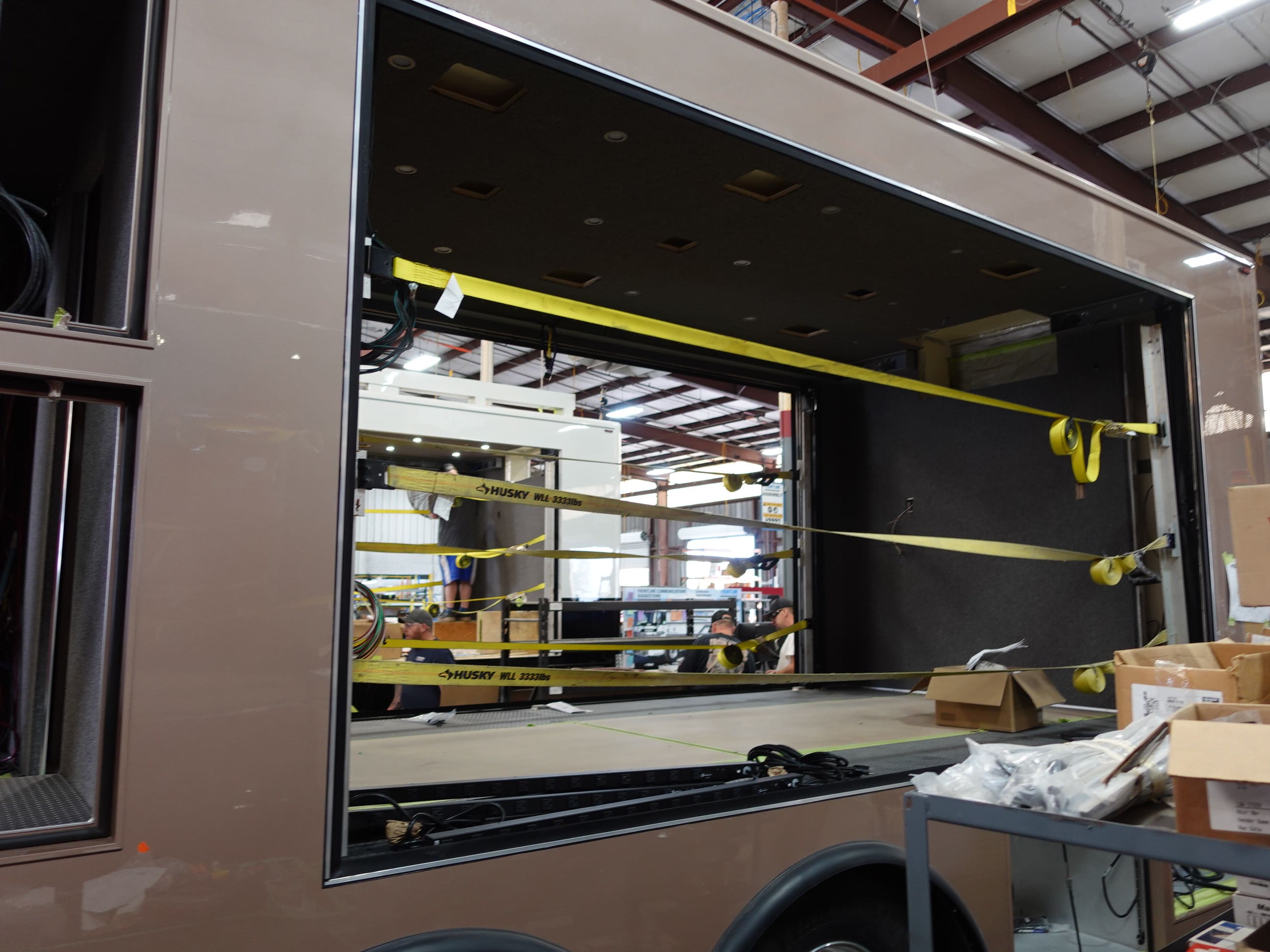

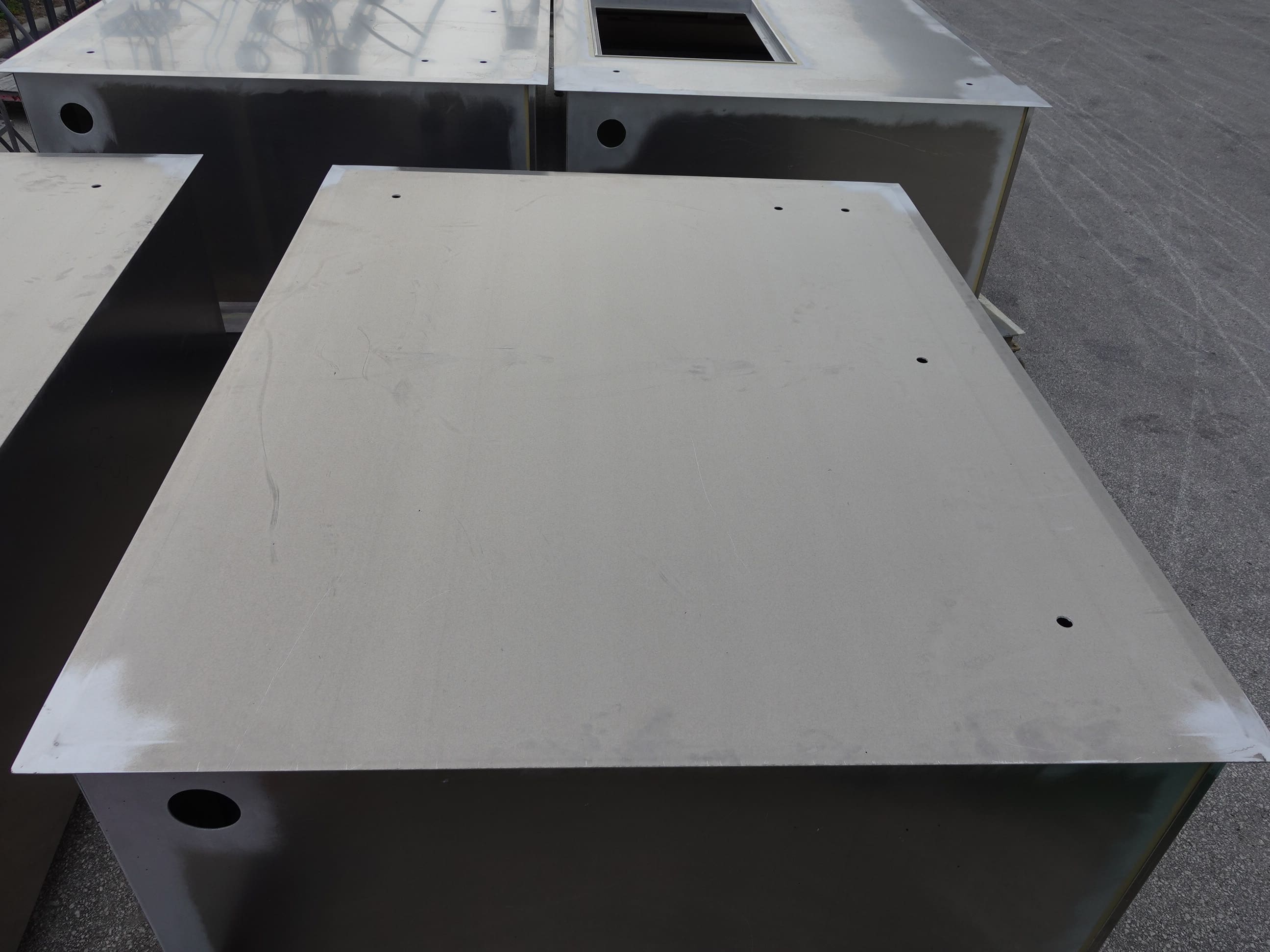

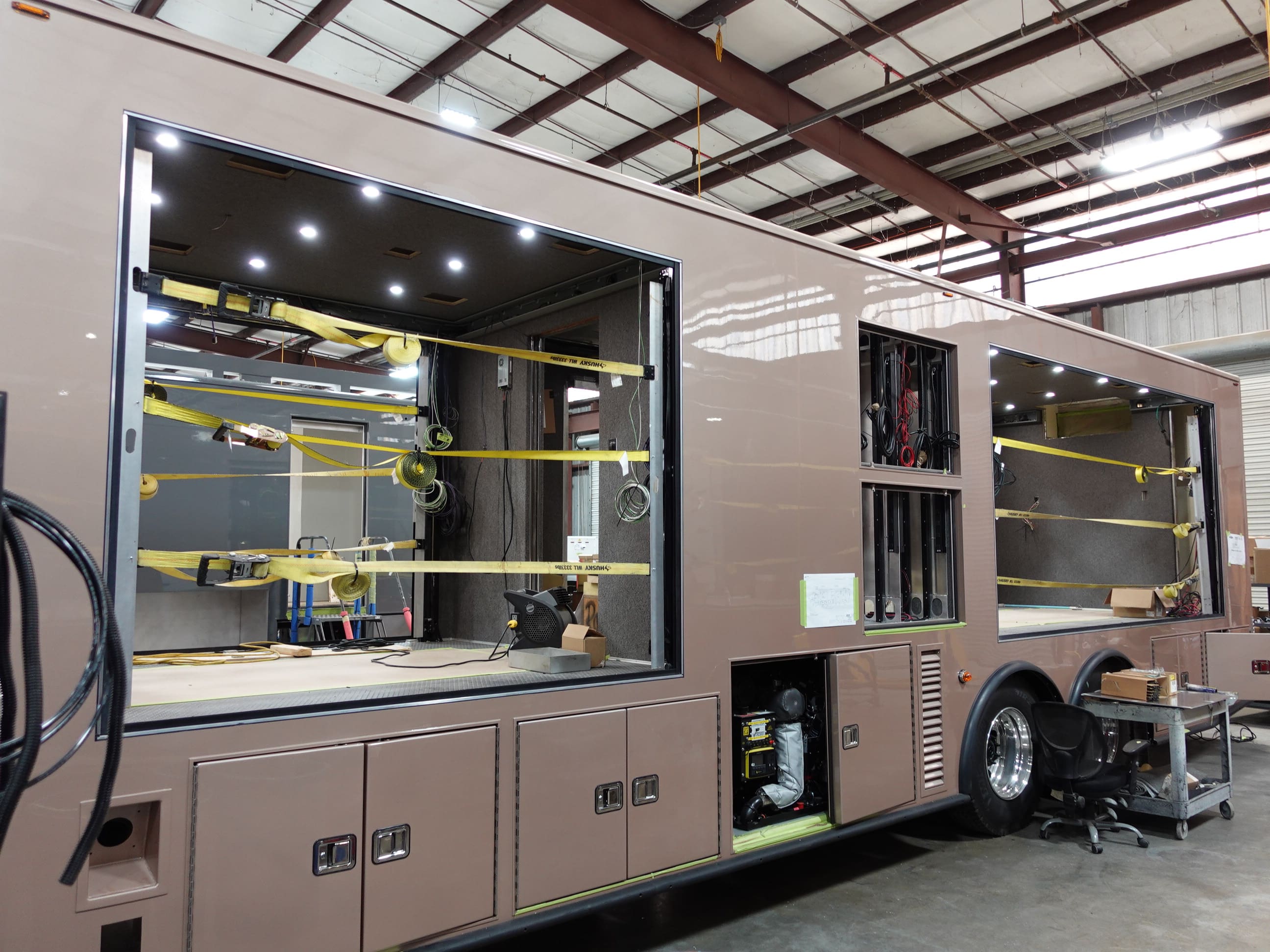

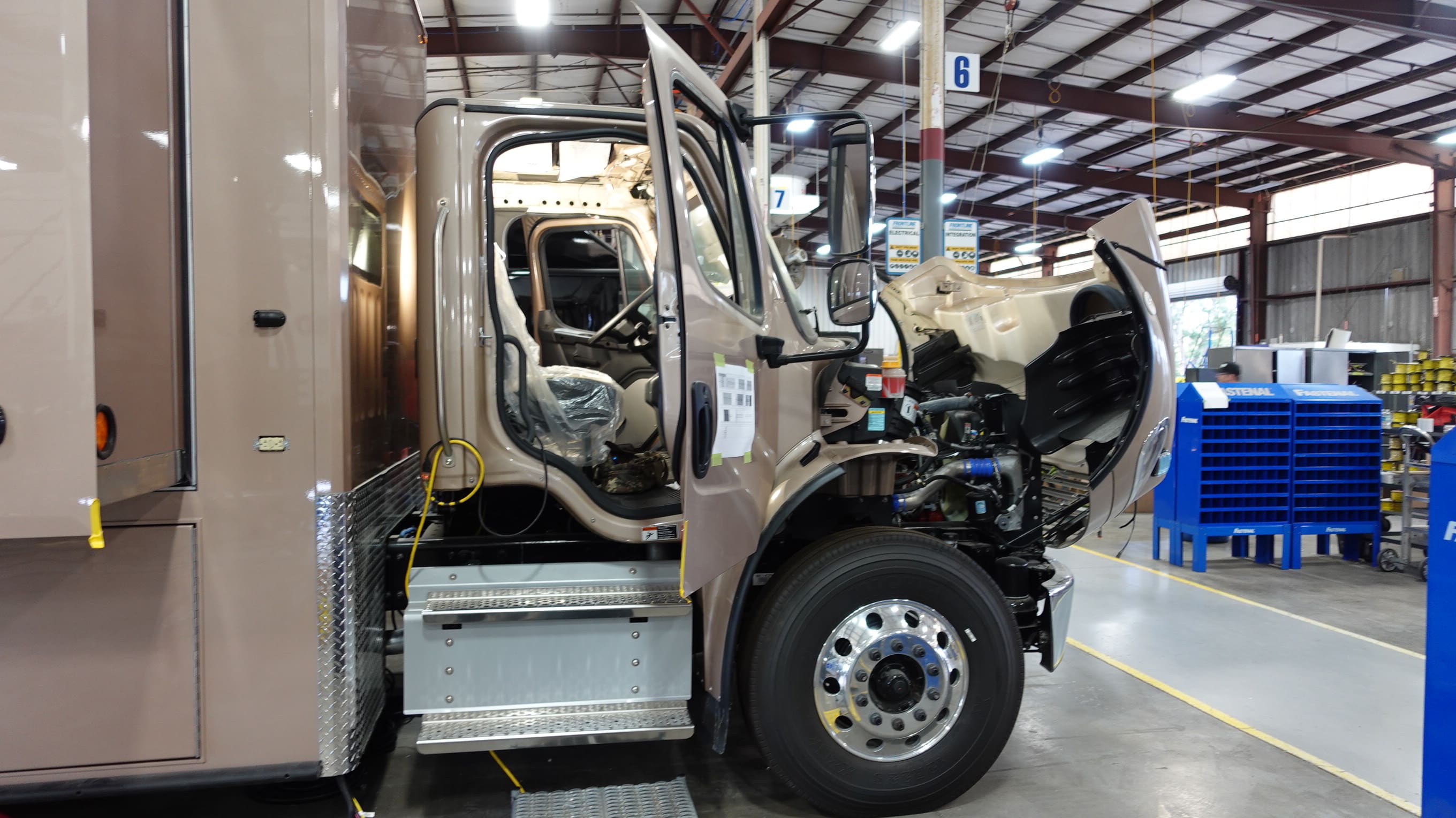

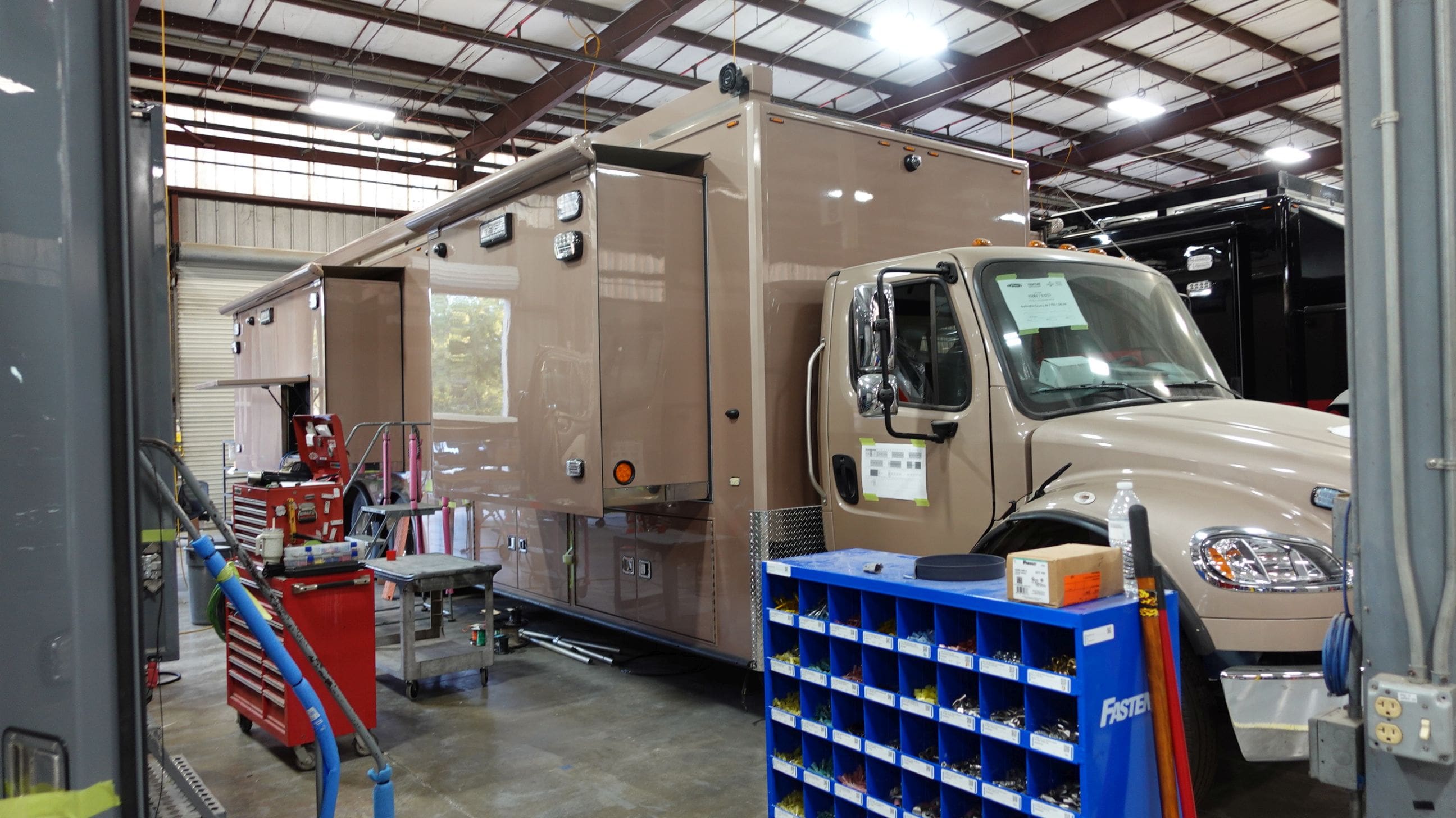

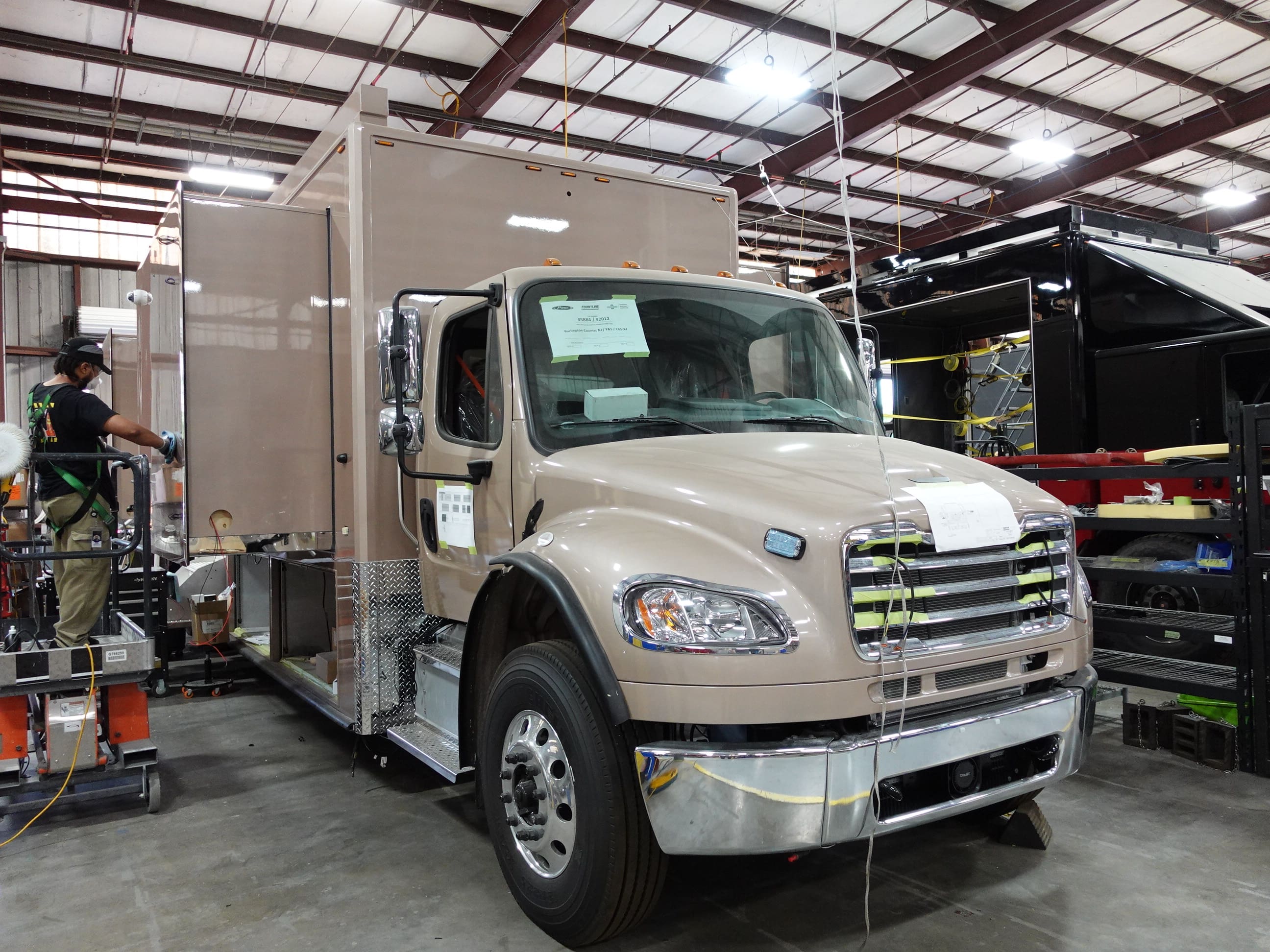

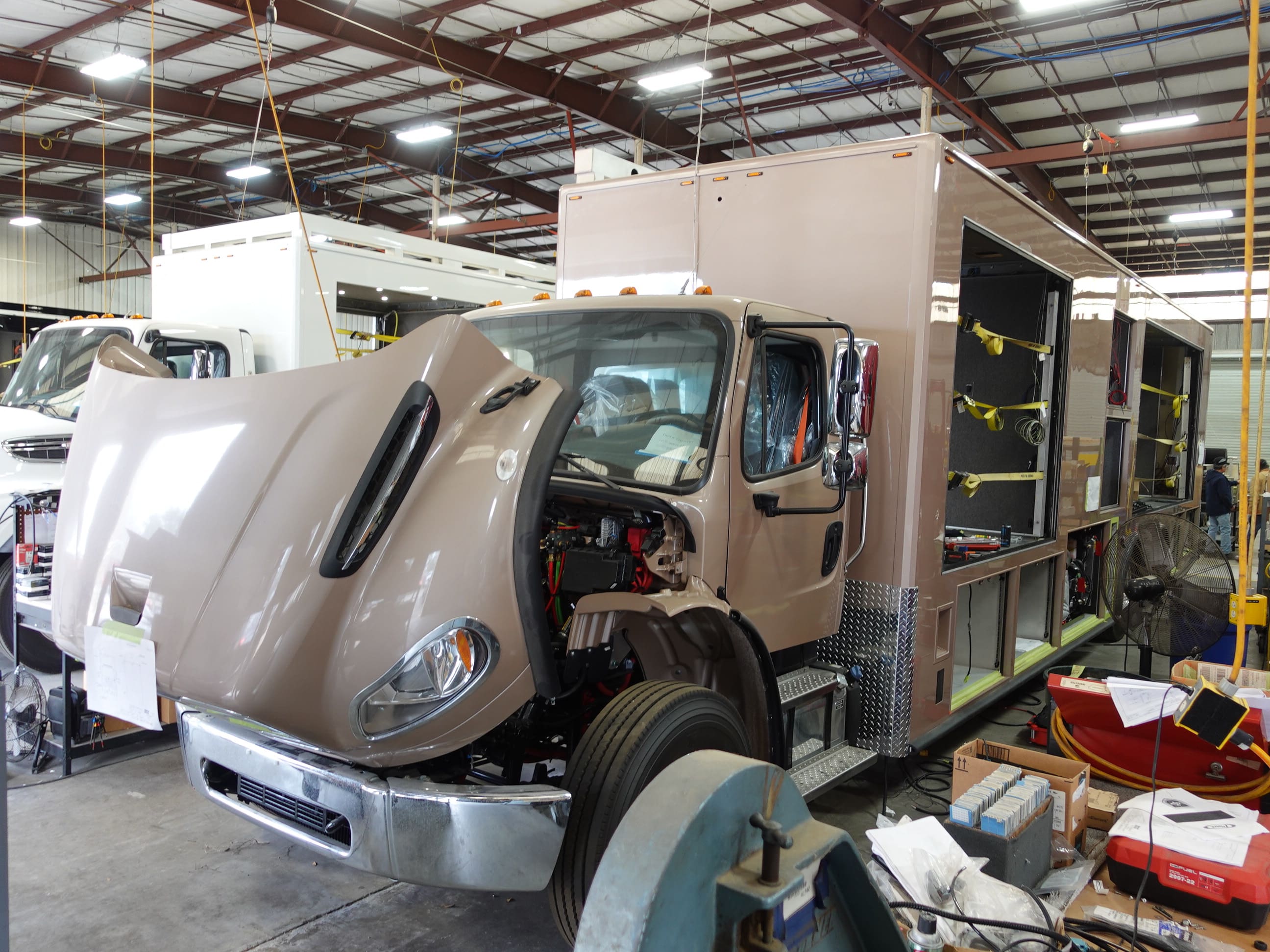

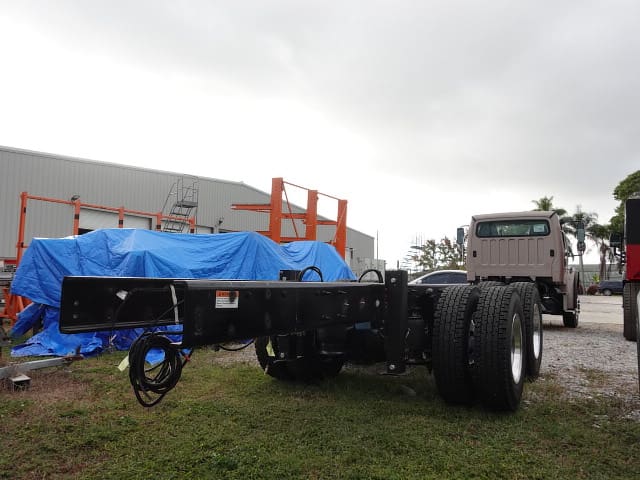

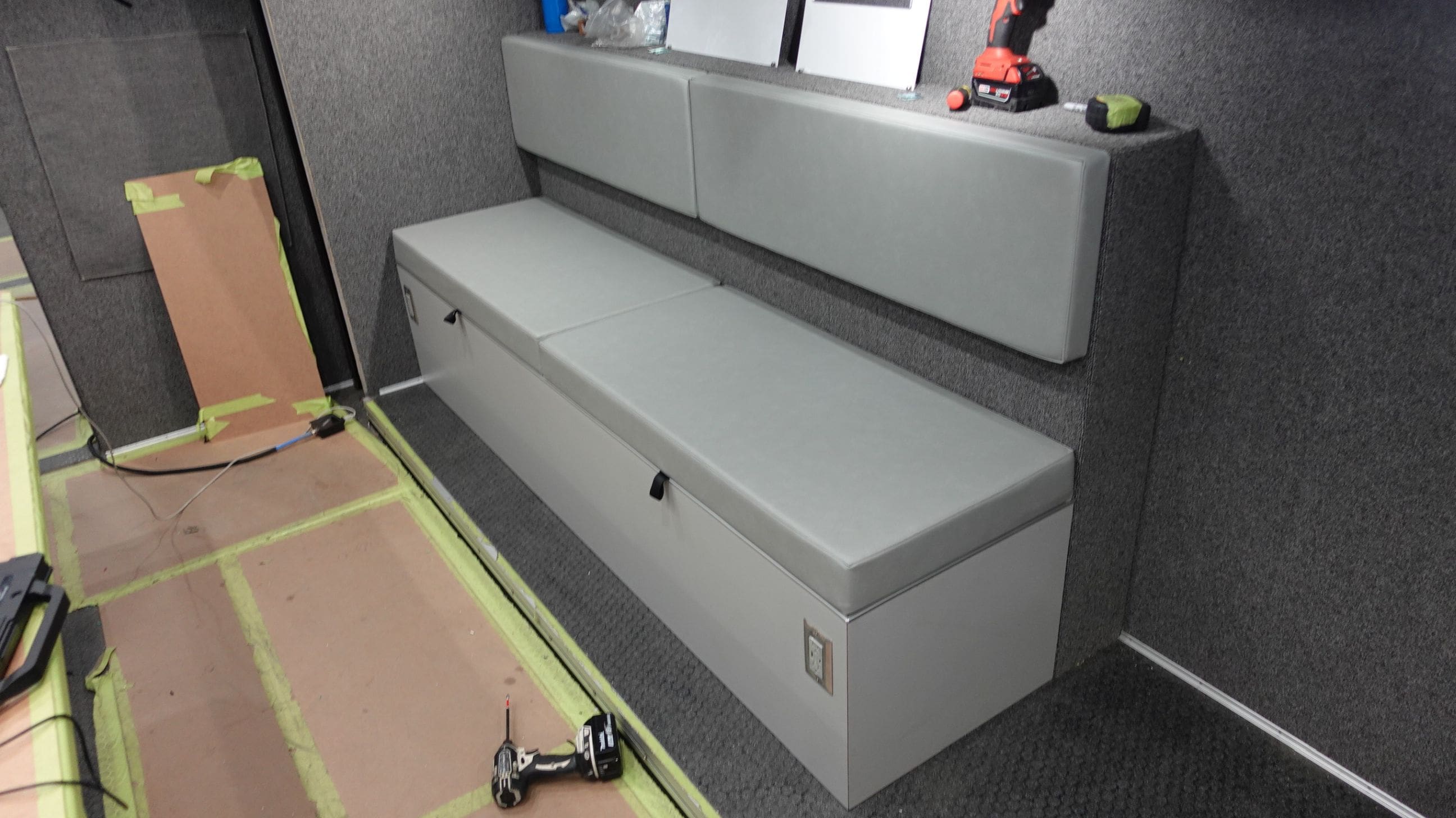

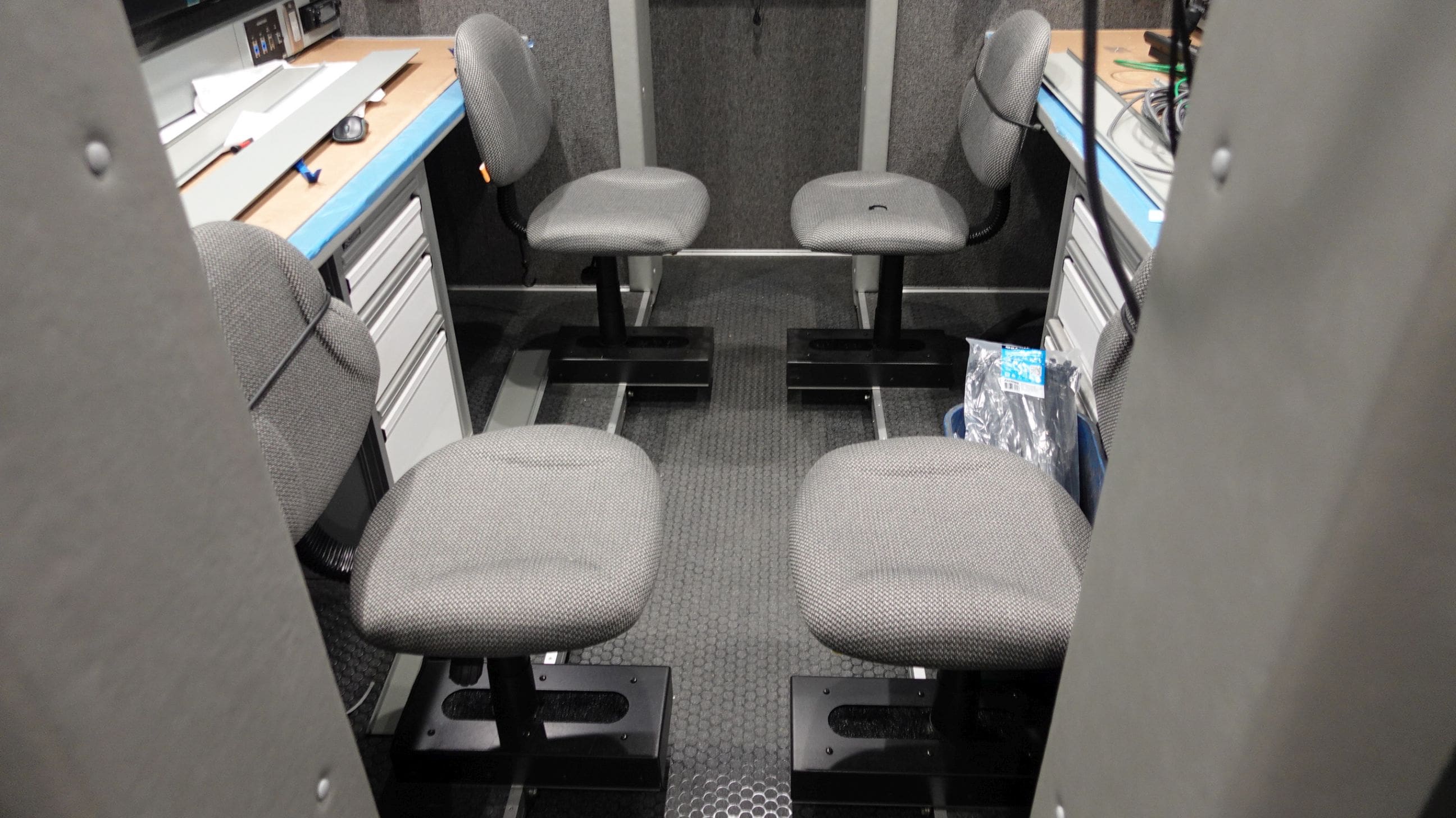

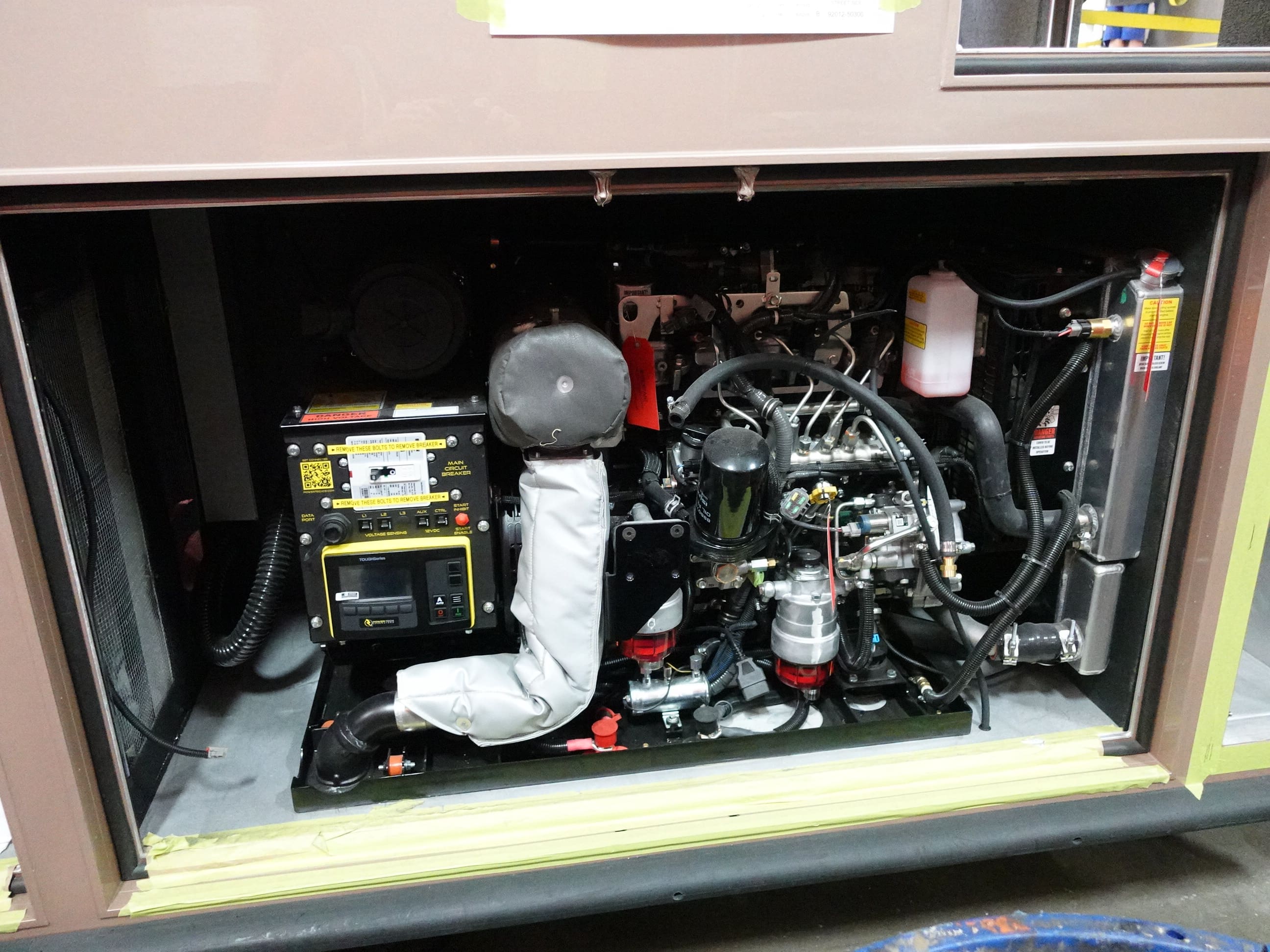

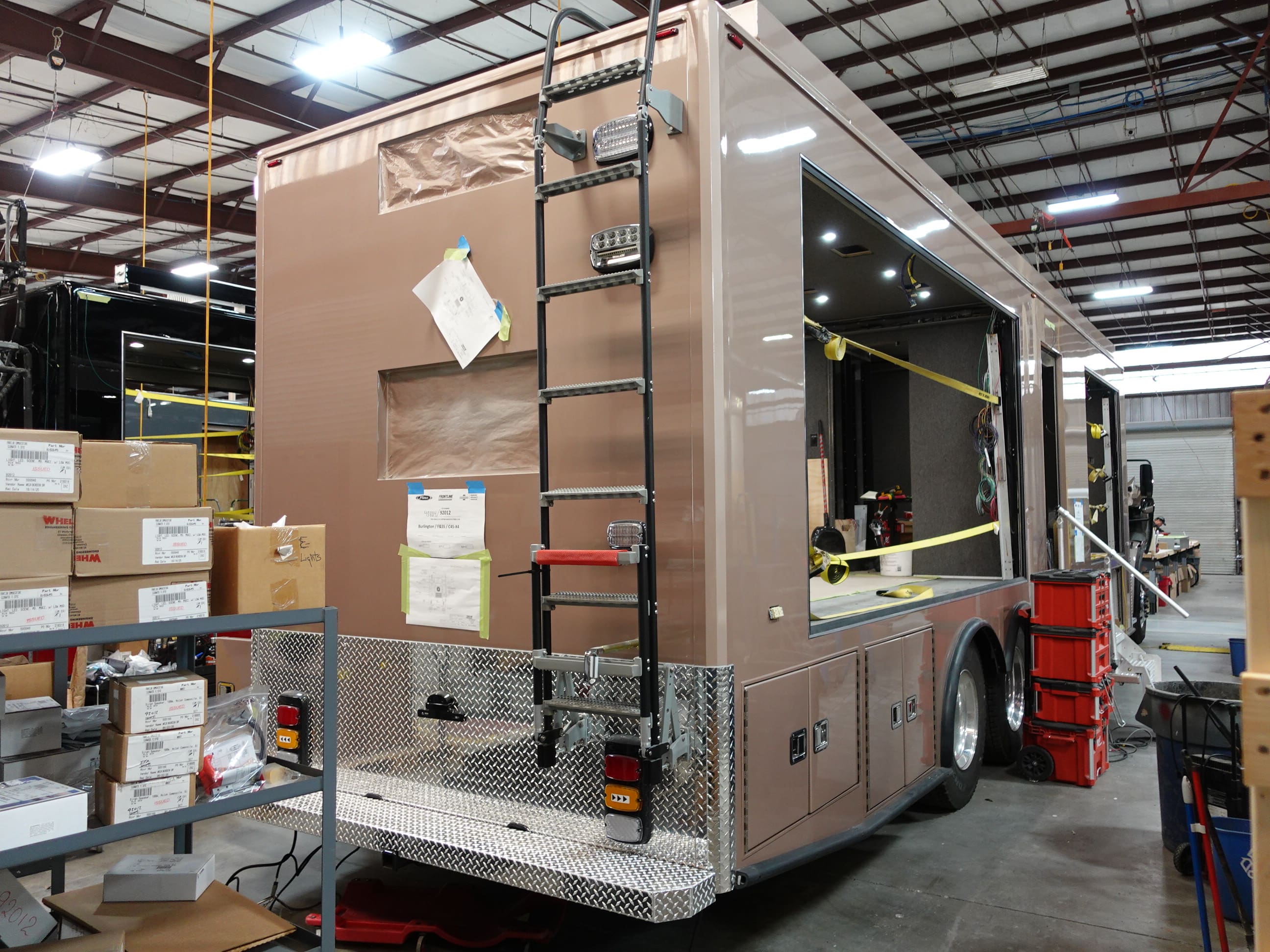

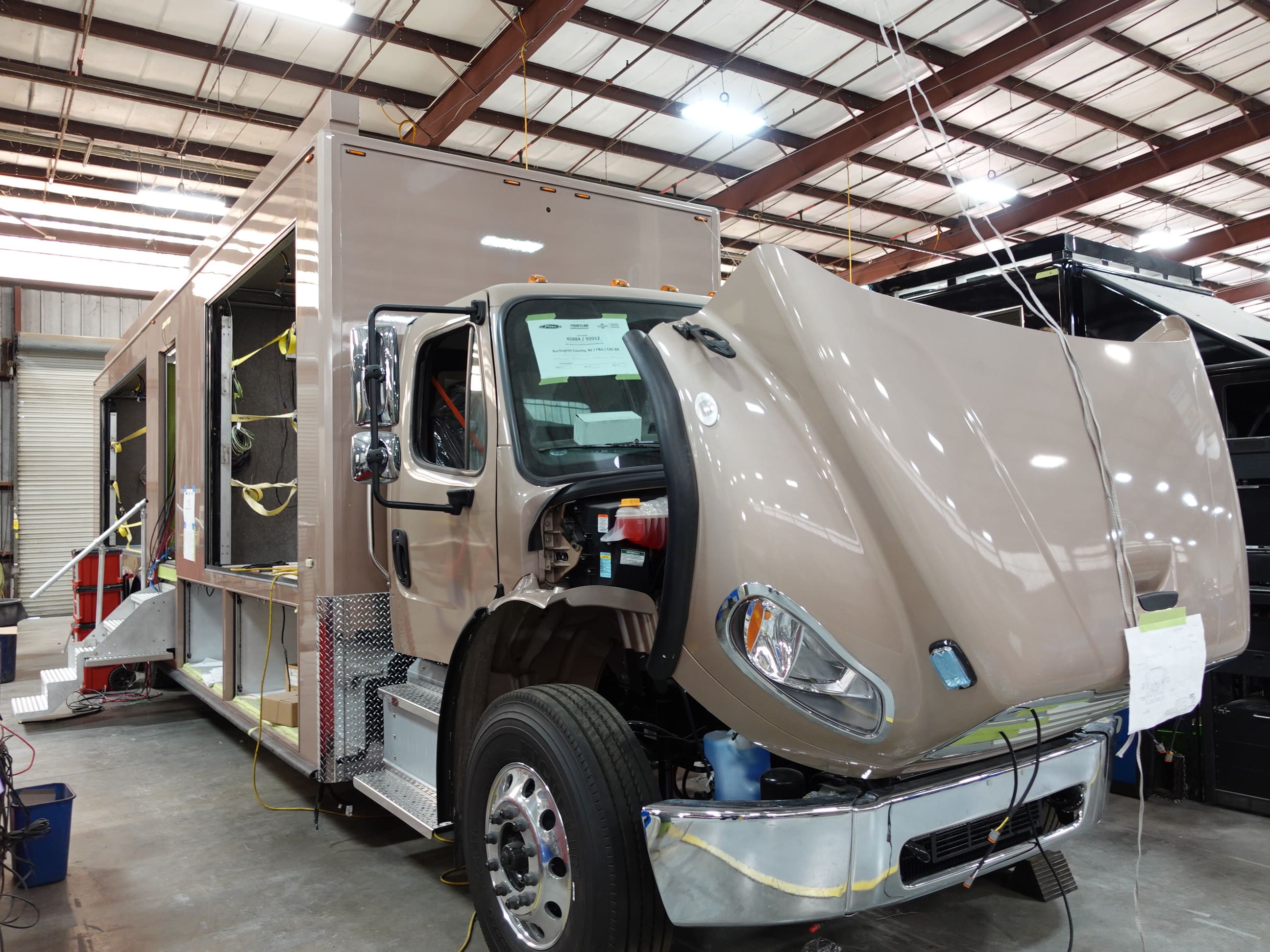

In this report, the apparatus completed assembly

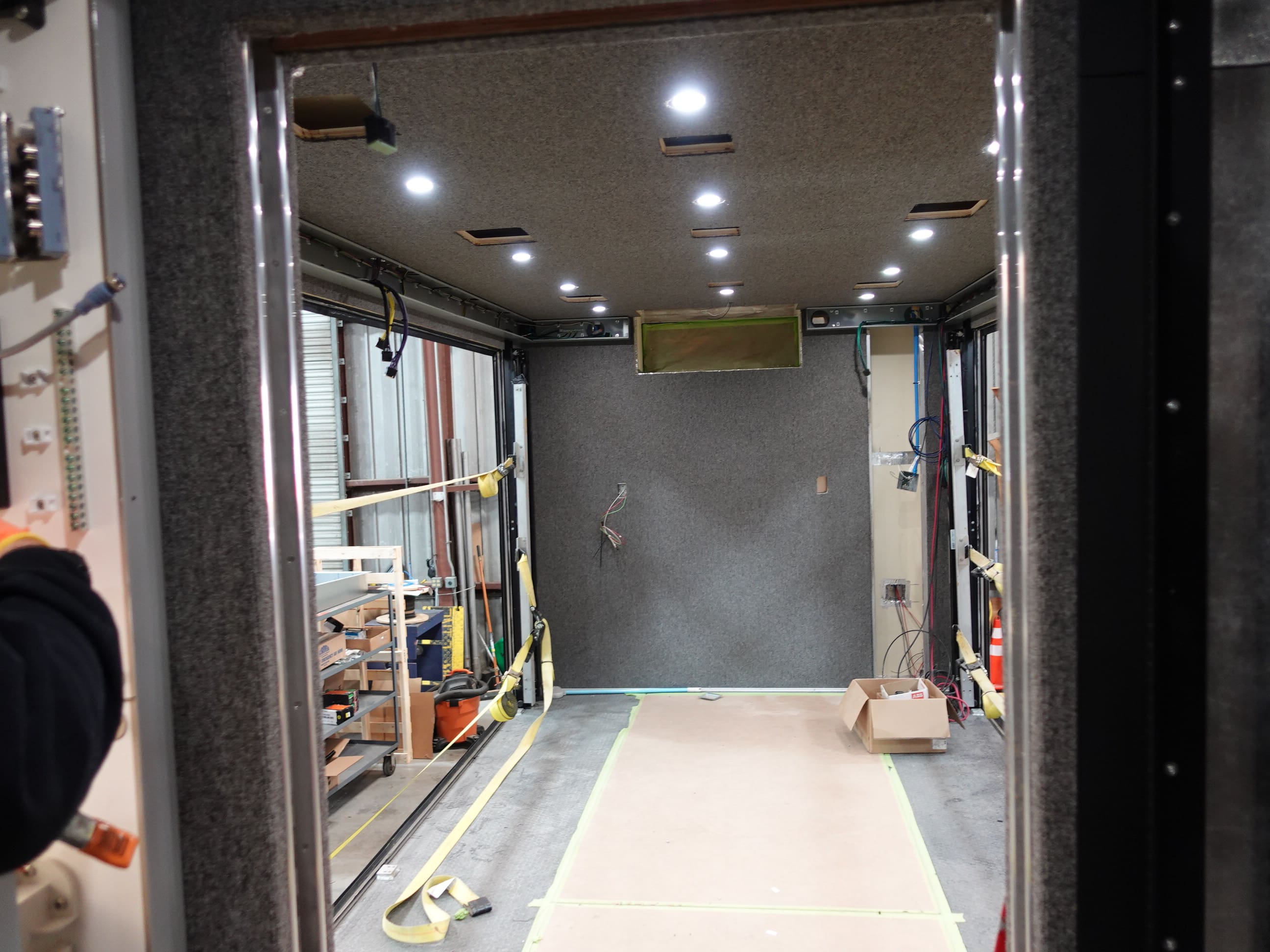

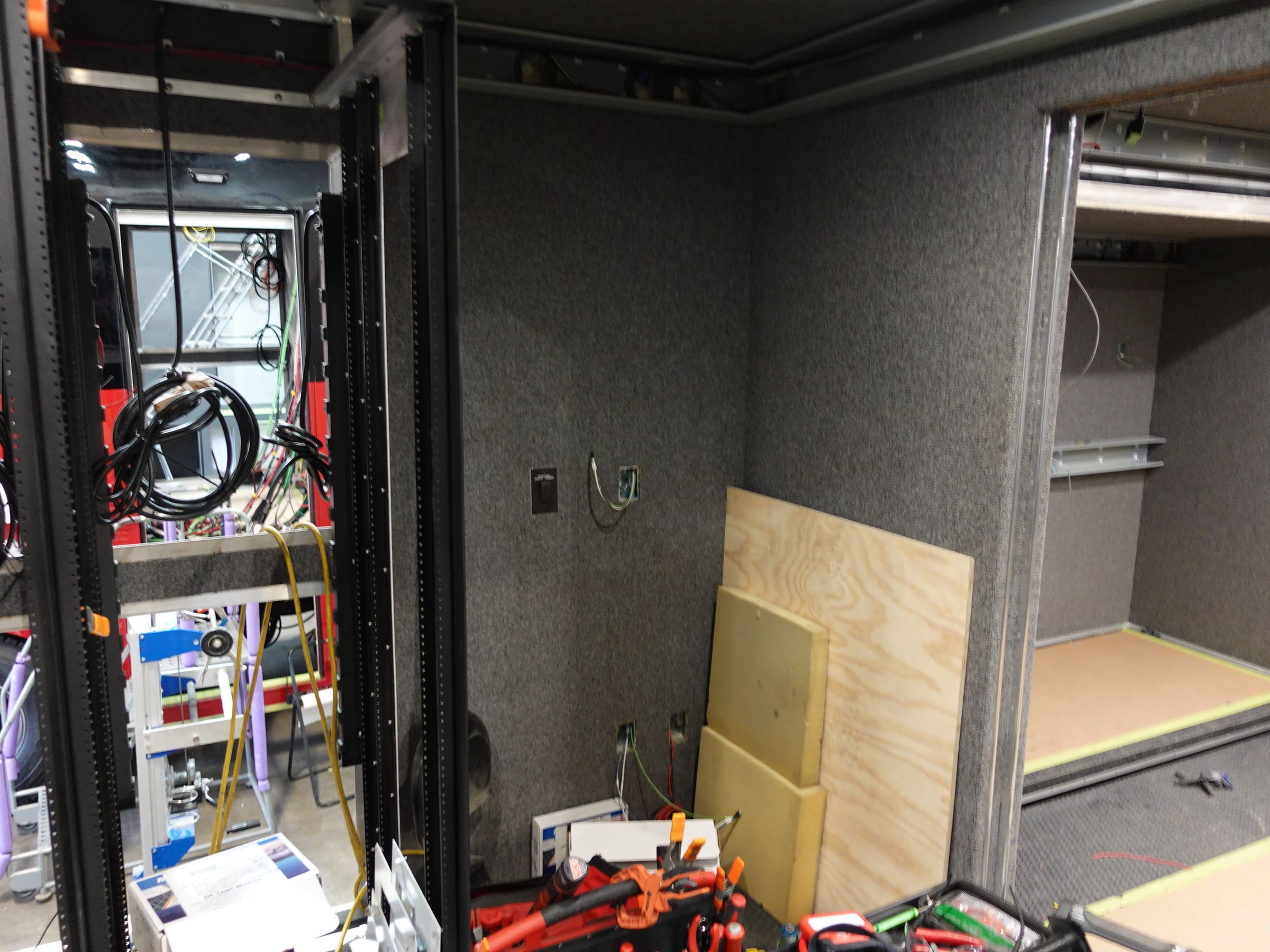

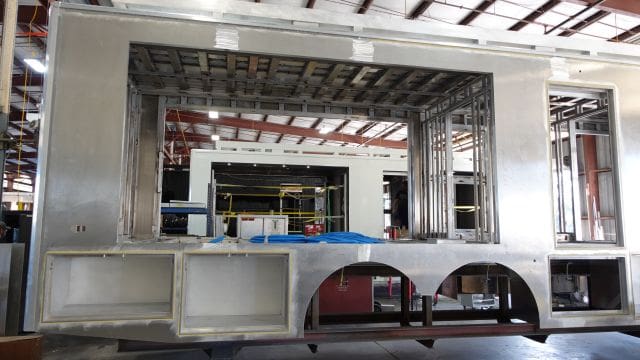

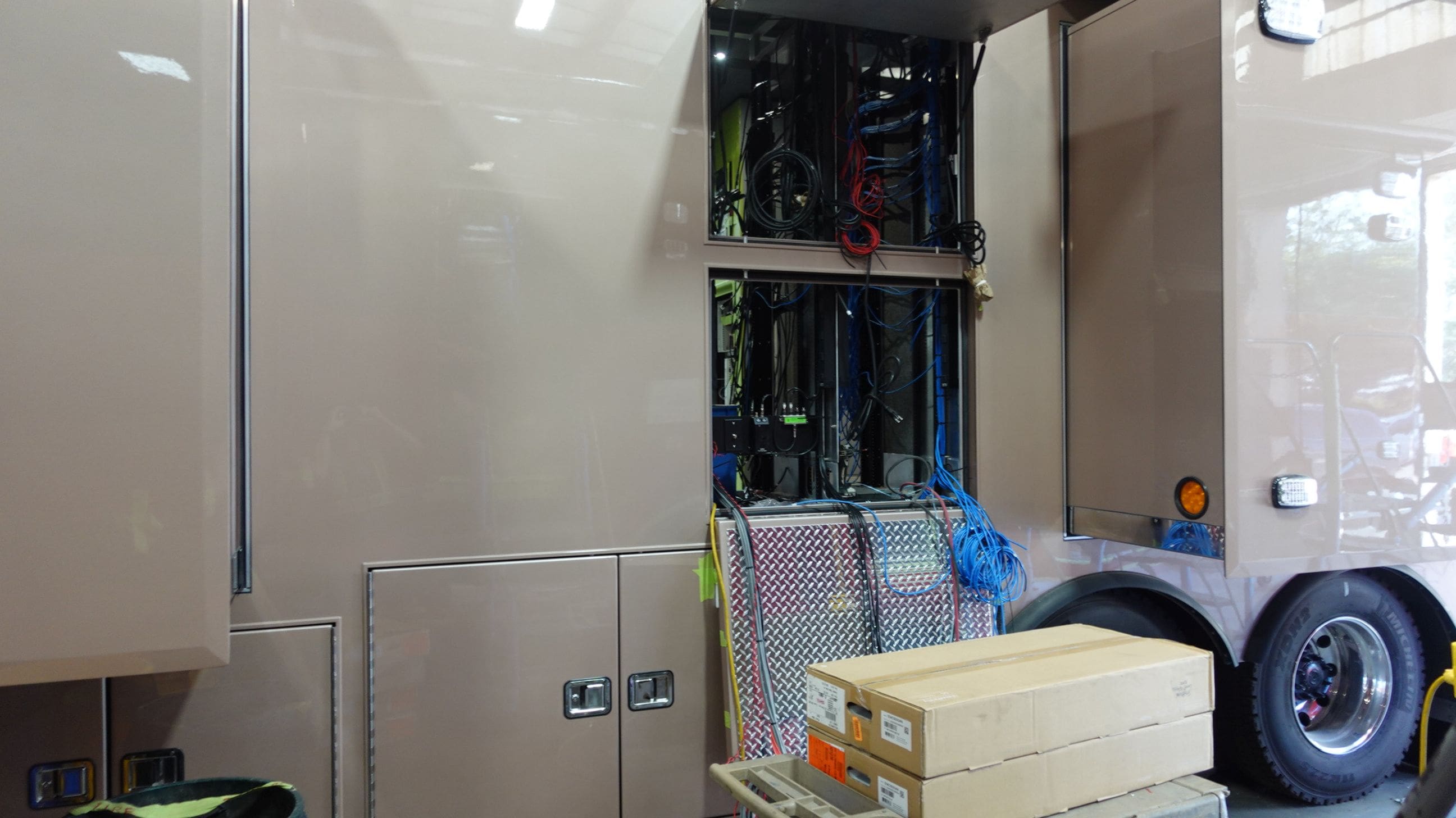

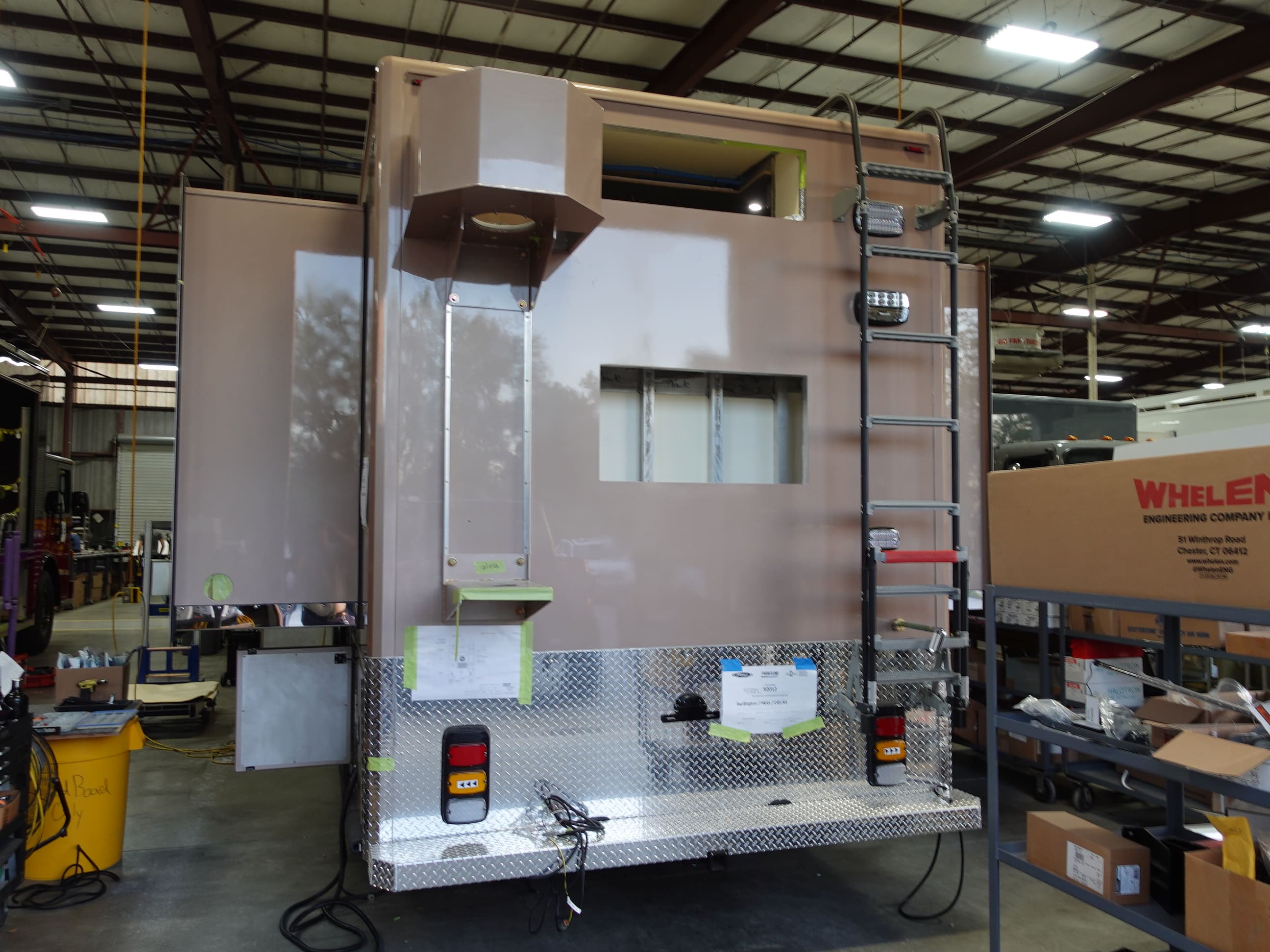

and began the integration process.

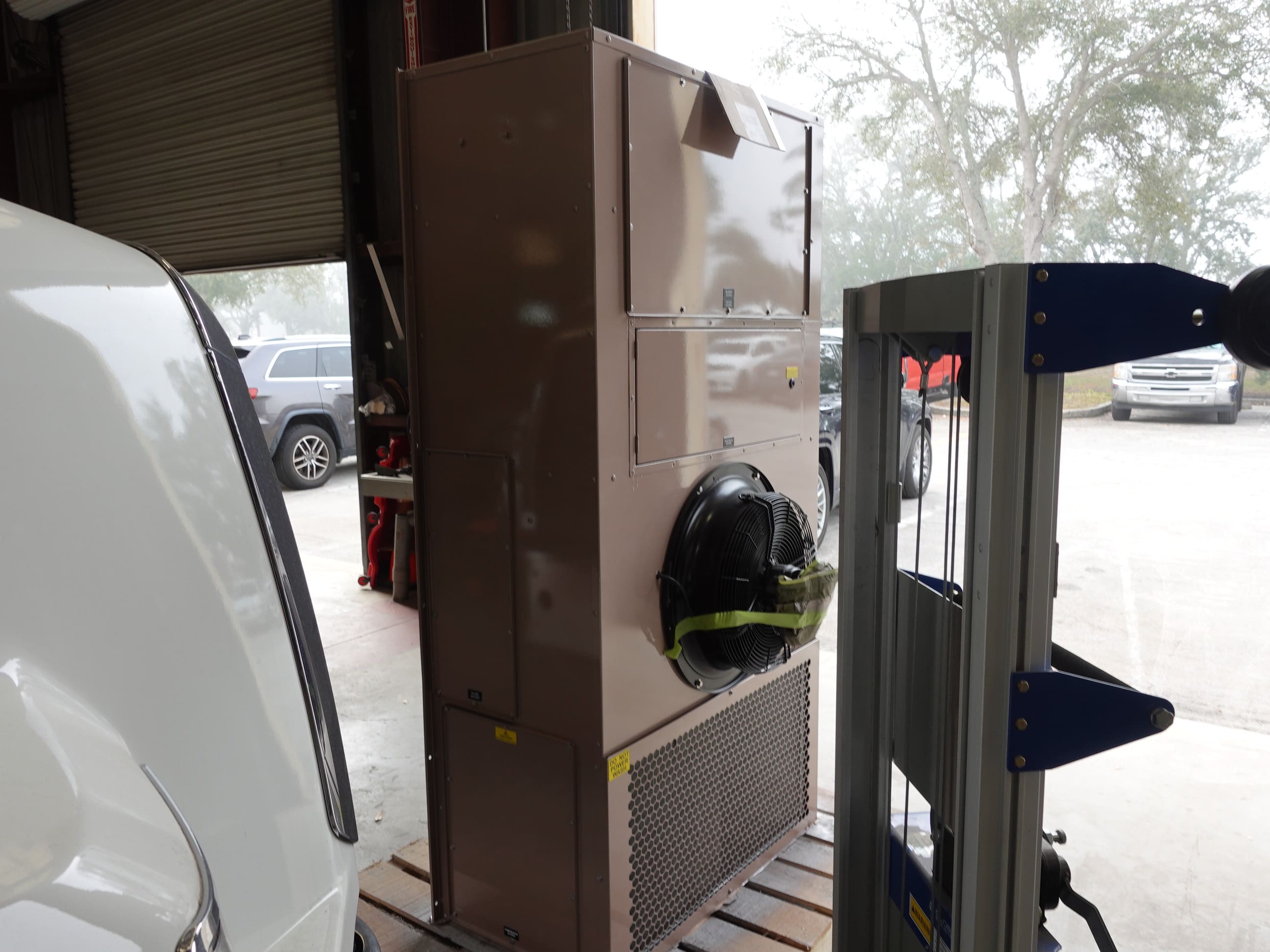

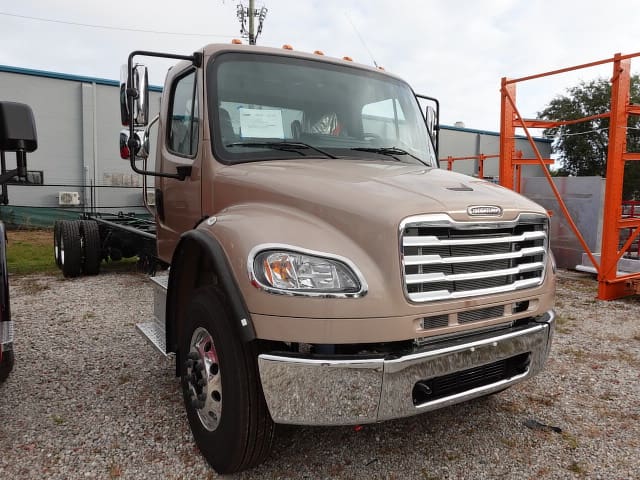

02-27-26

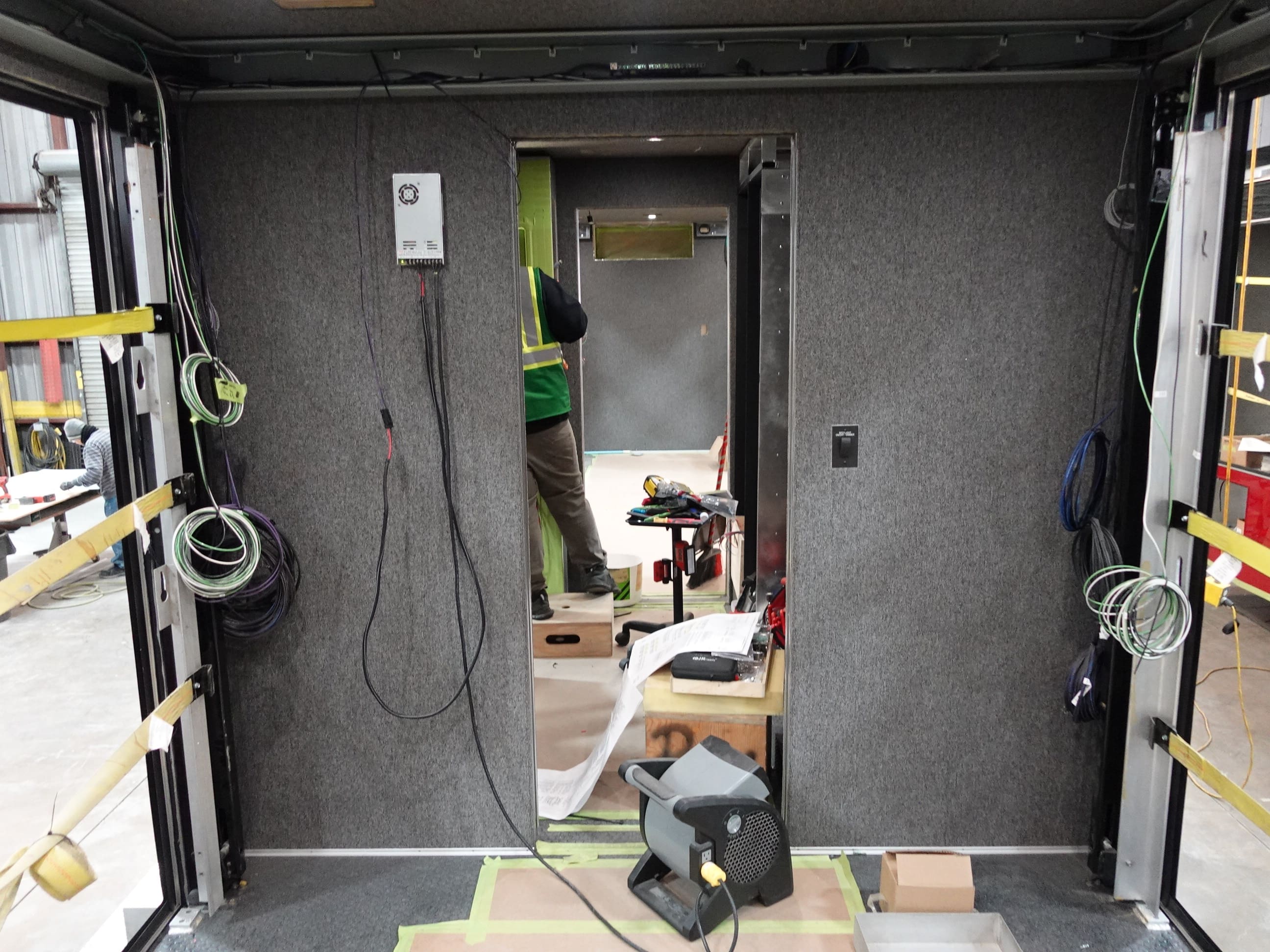

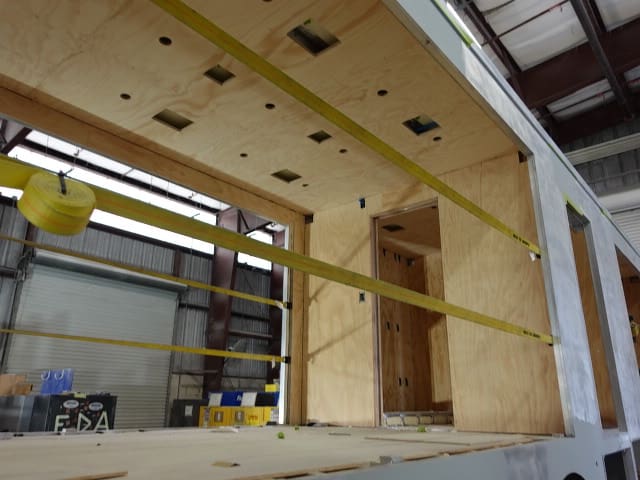

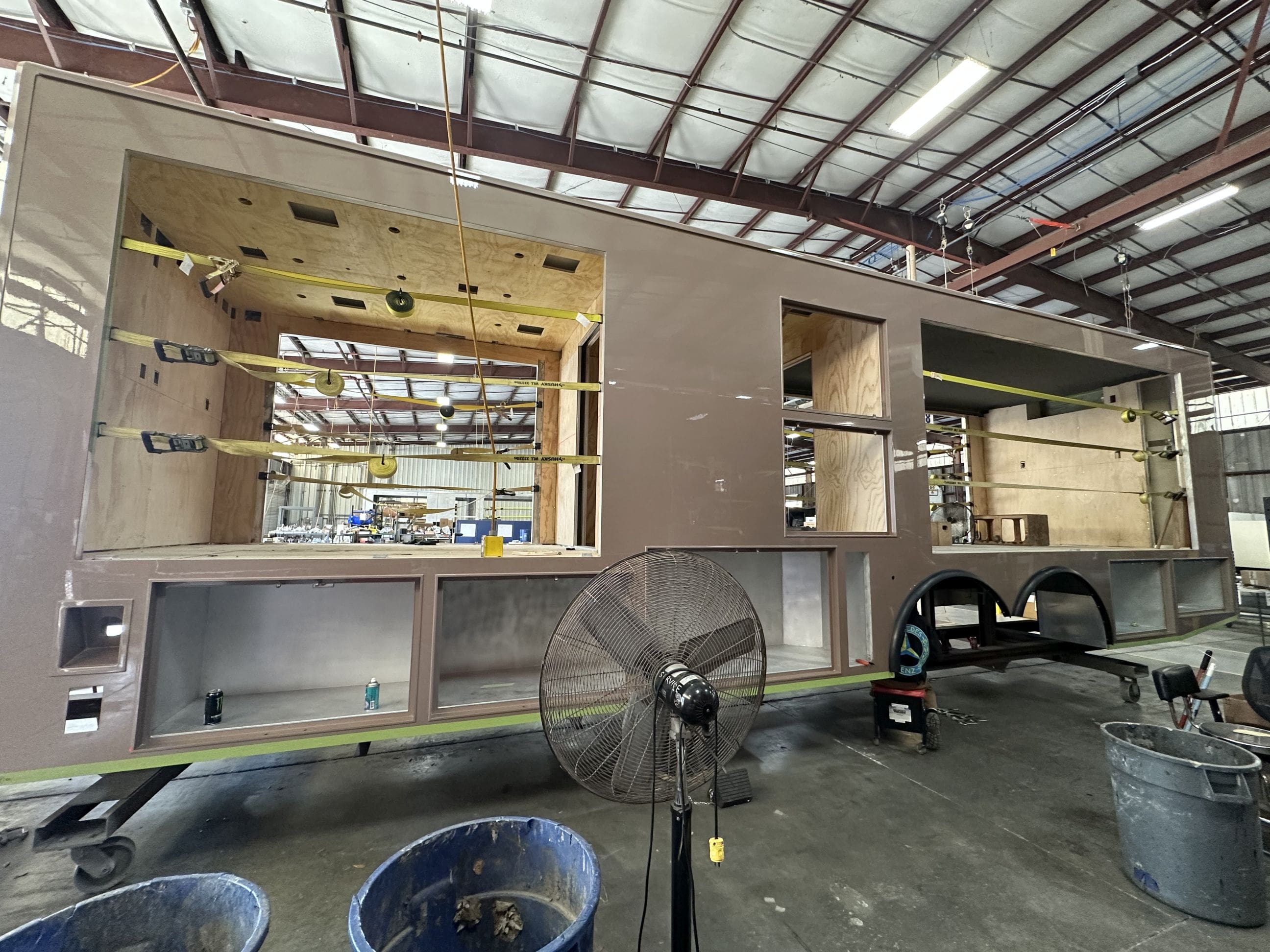

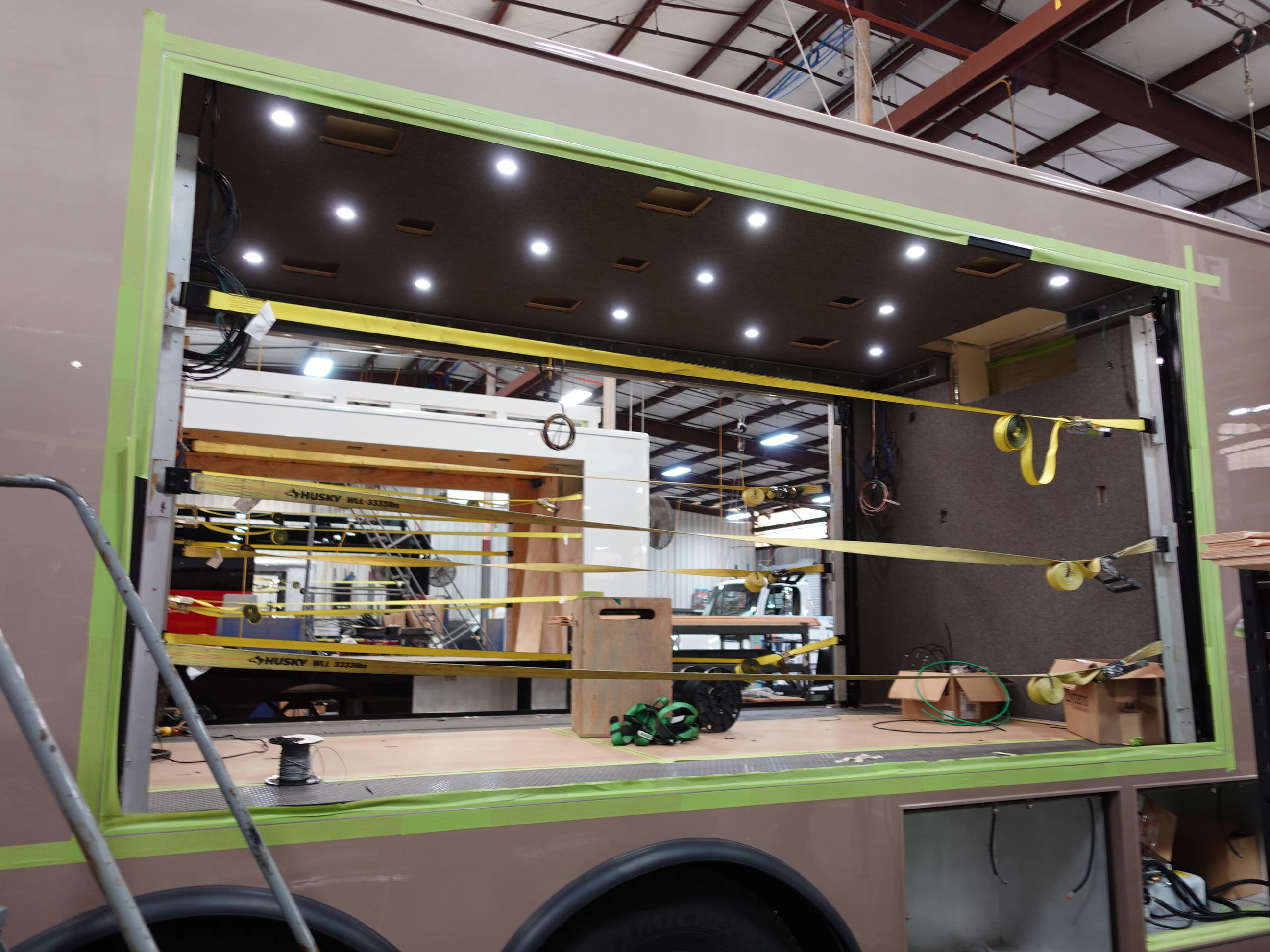

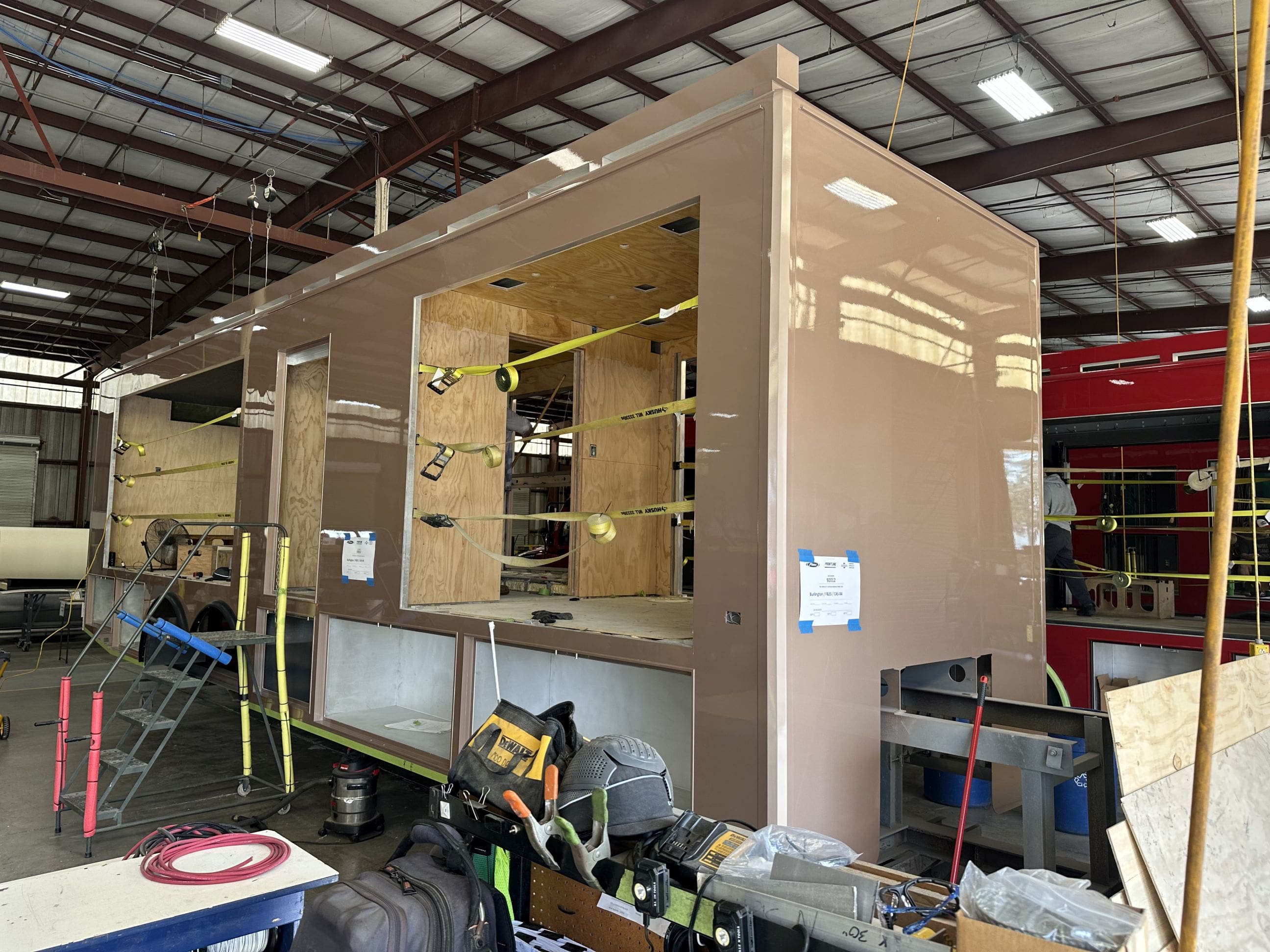

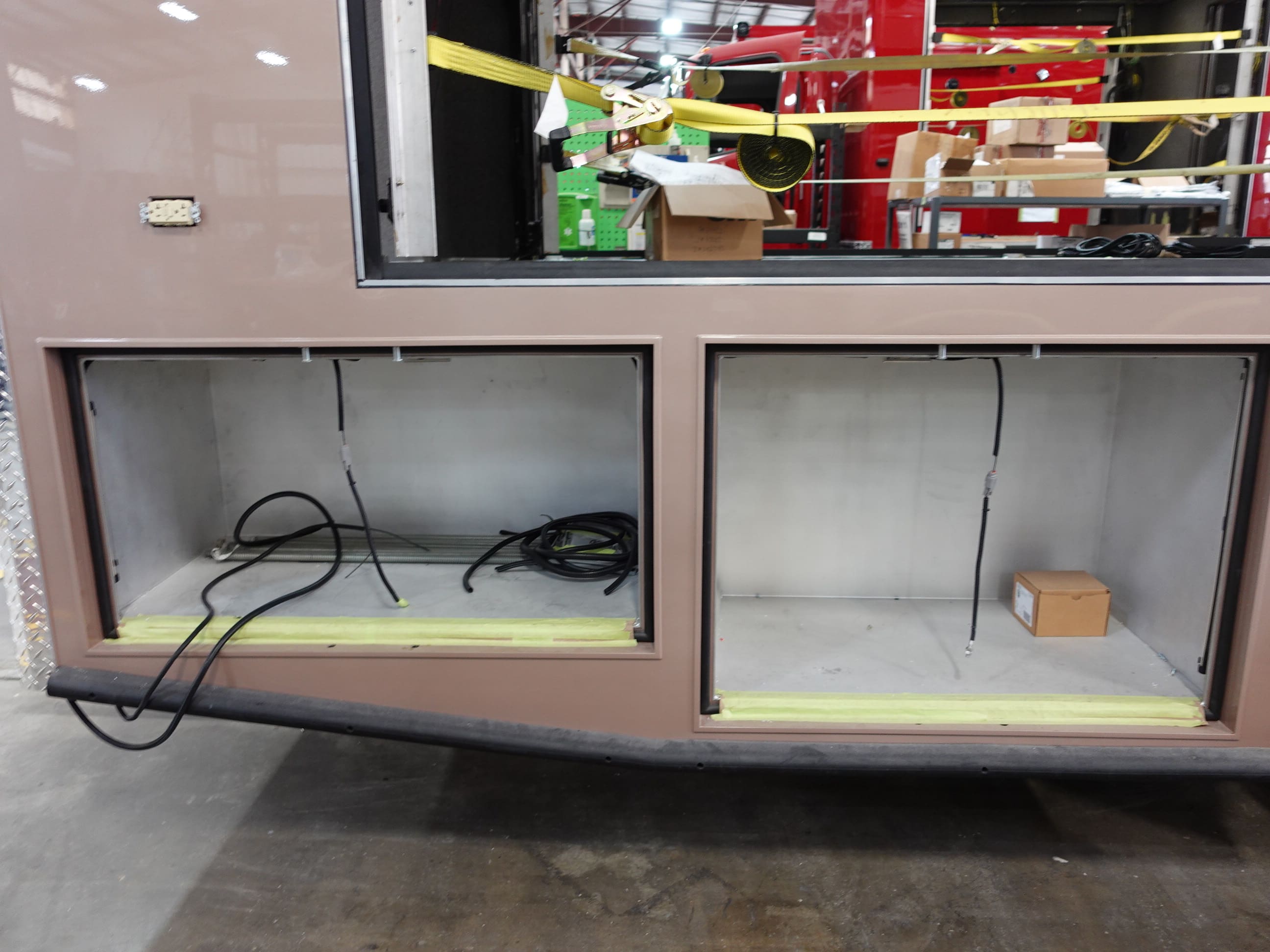

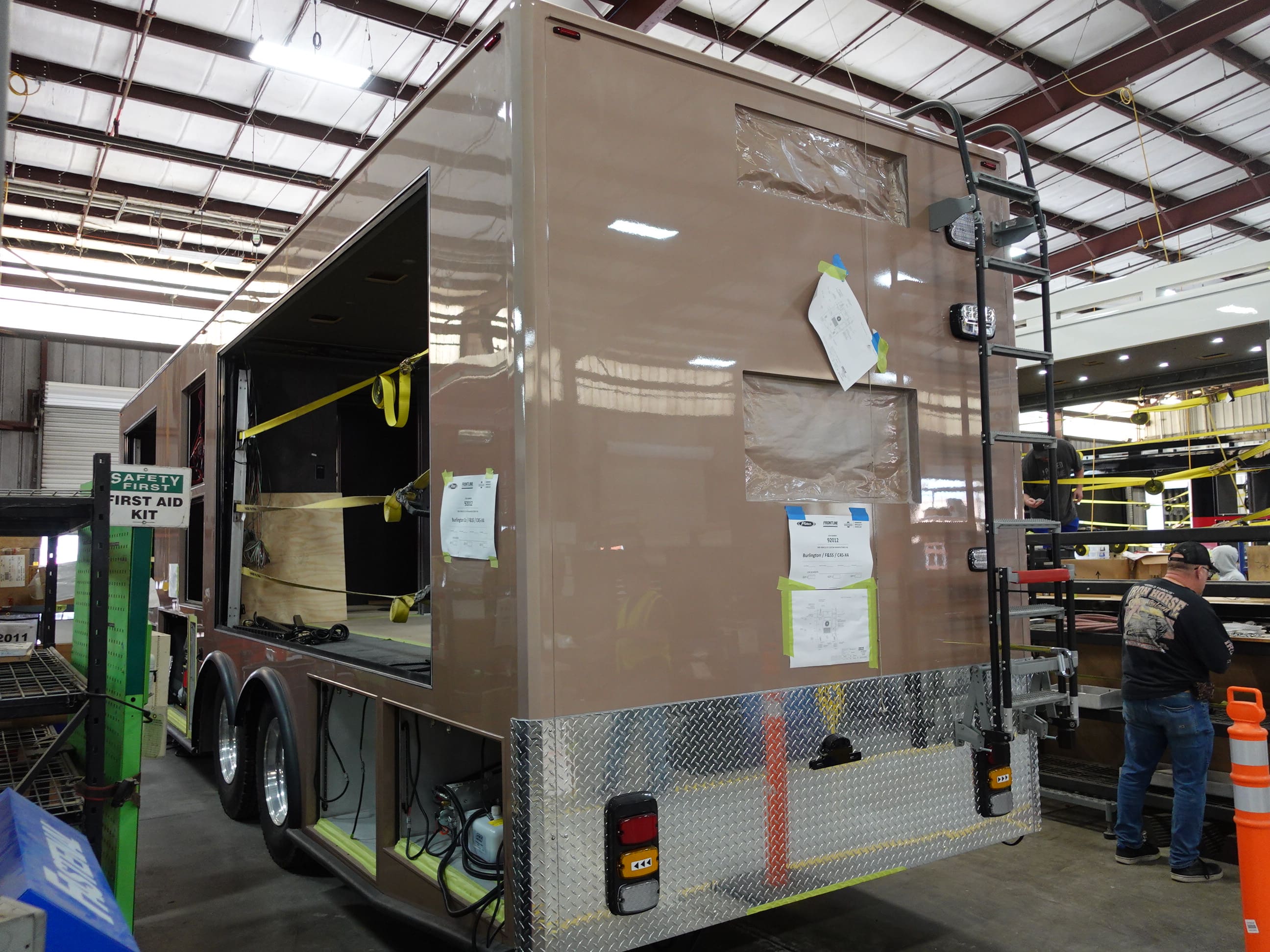

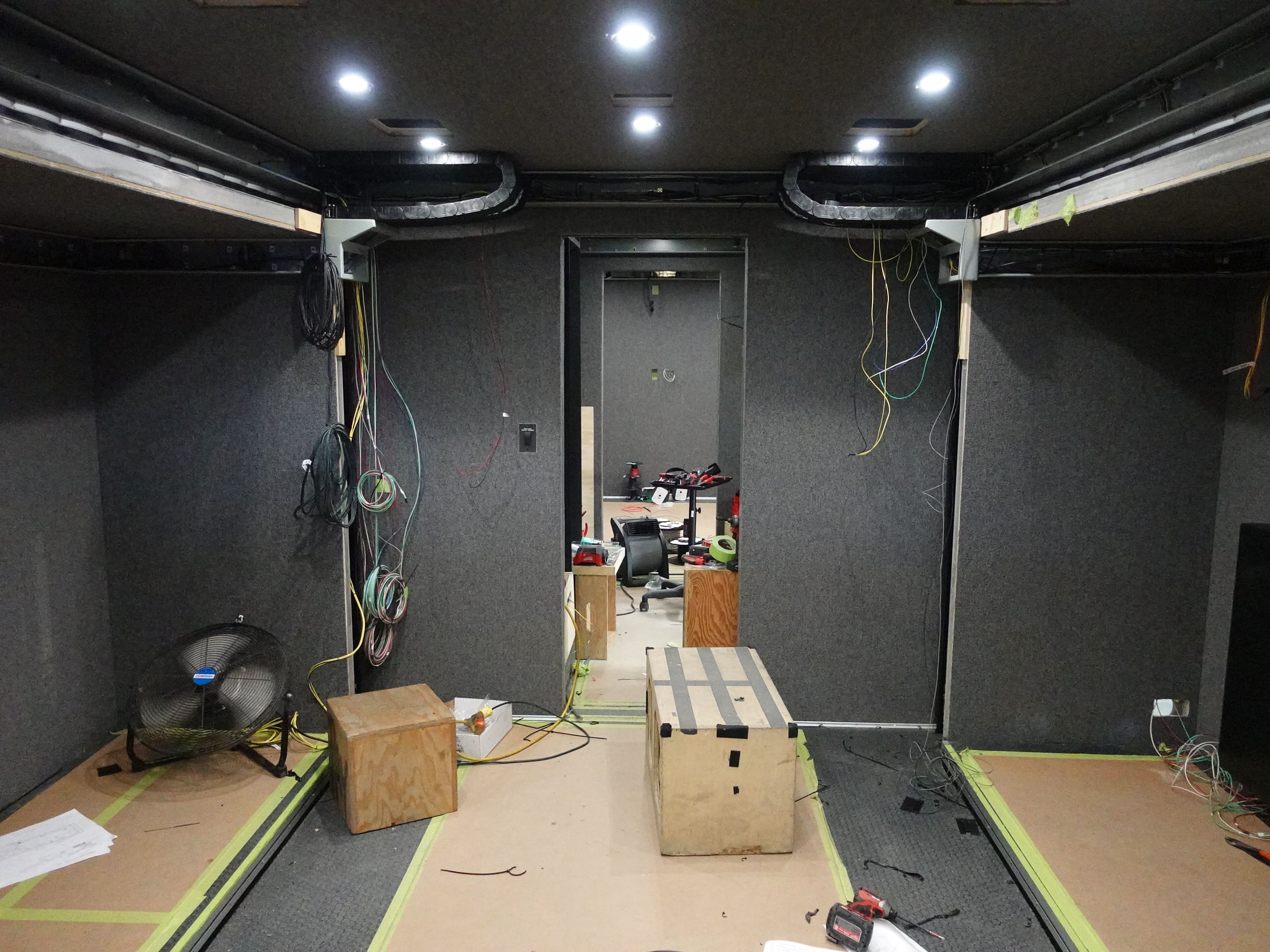

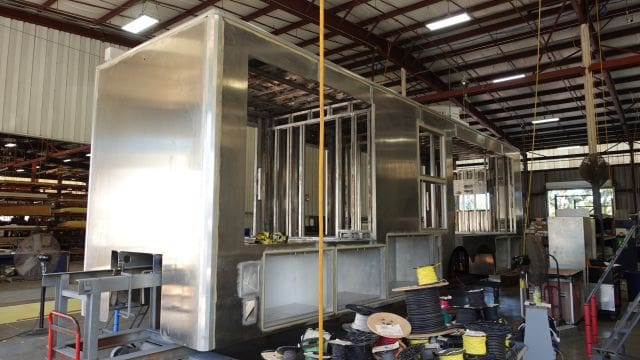

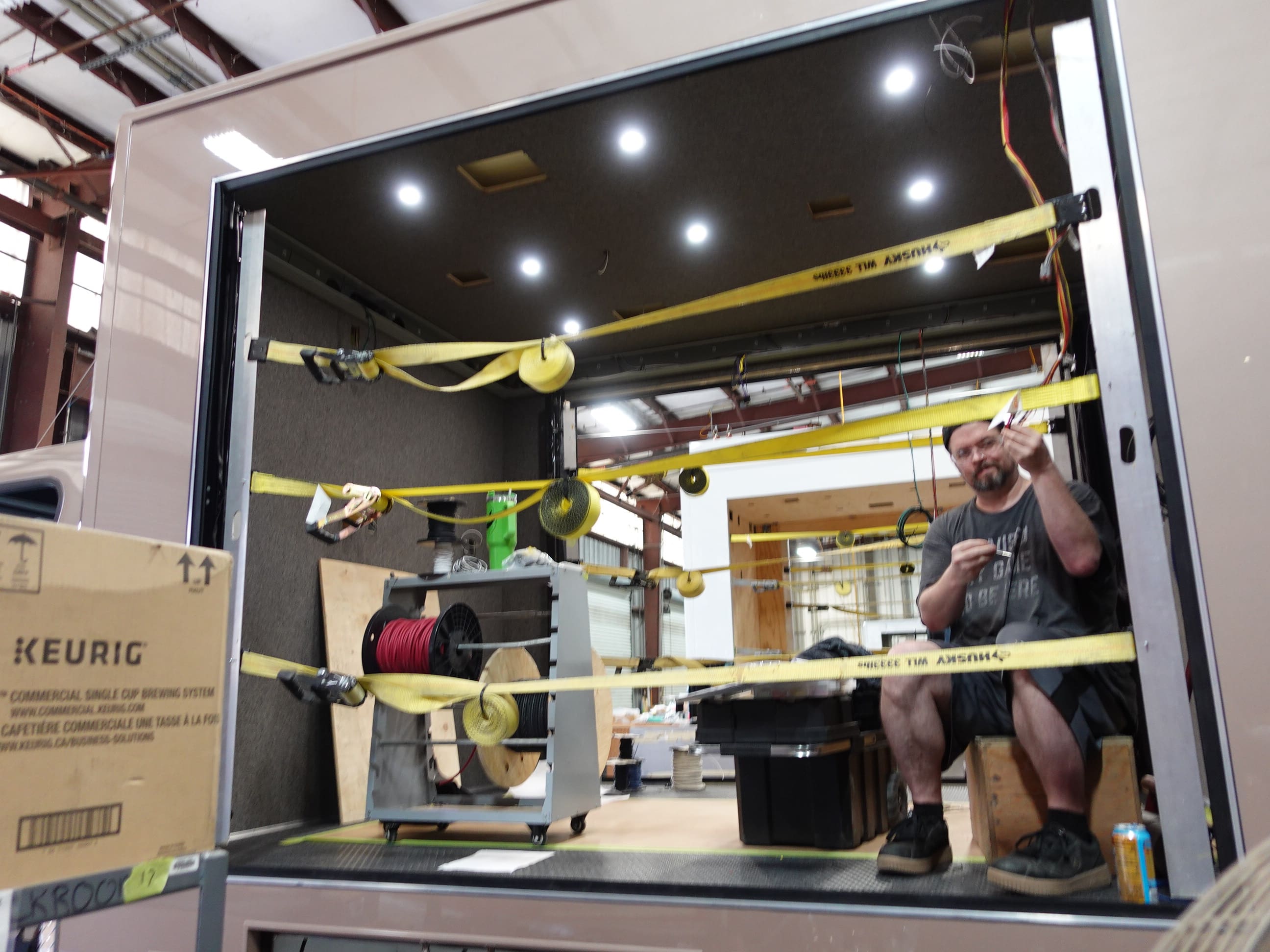

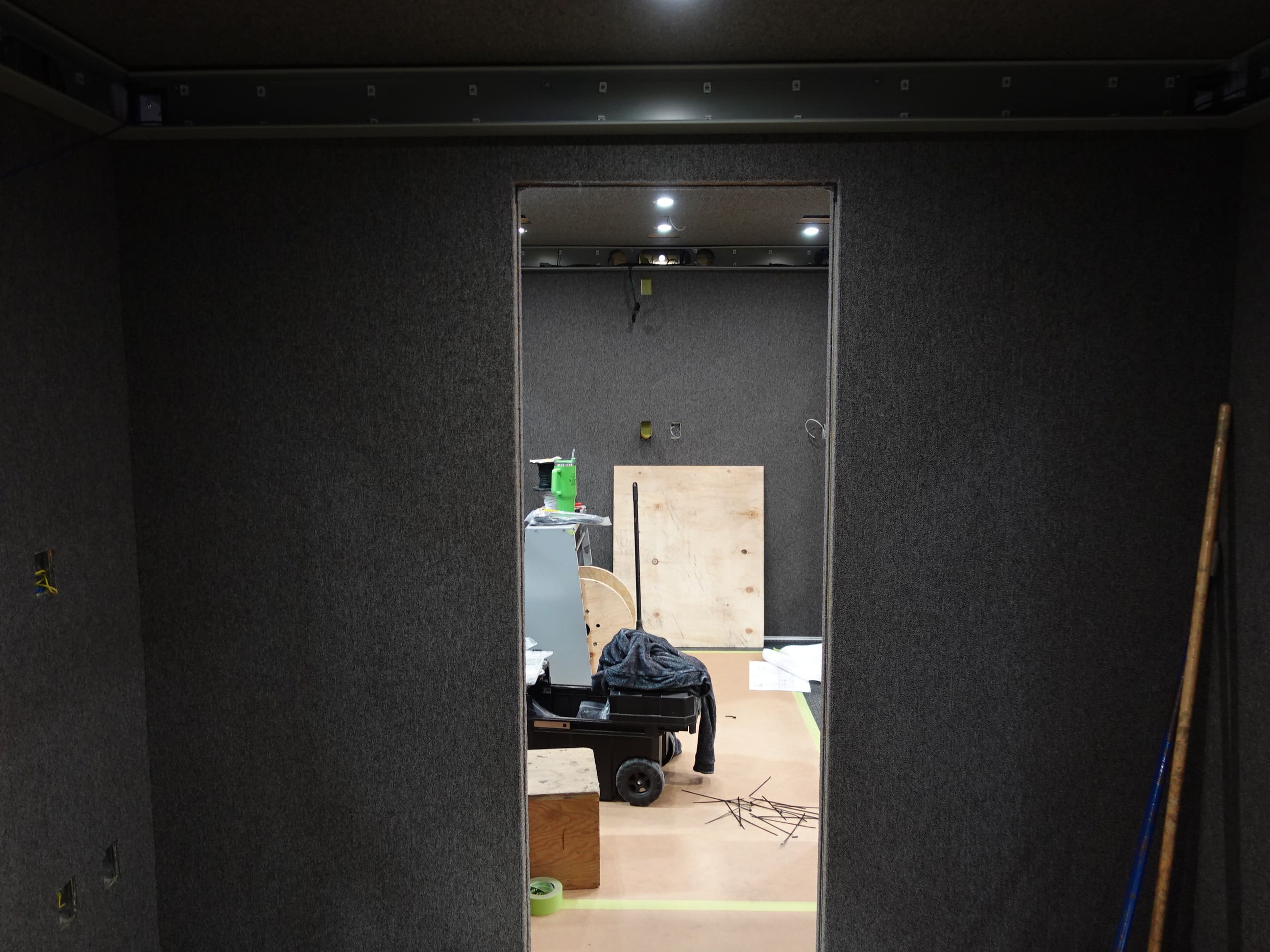

In this report, the apparatus continued assembly while the slide-outs completed paint and began assembly.
02-13-26

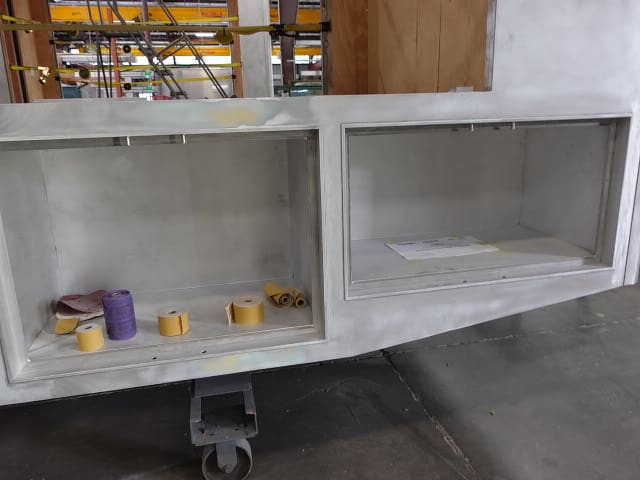

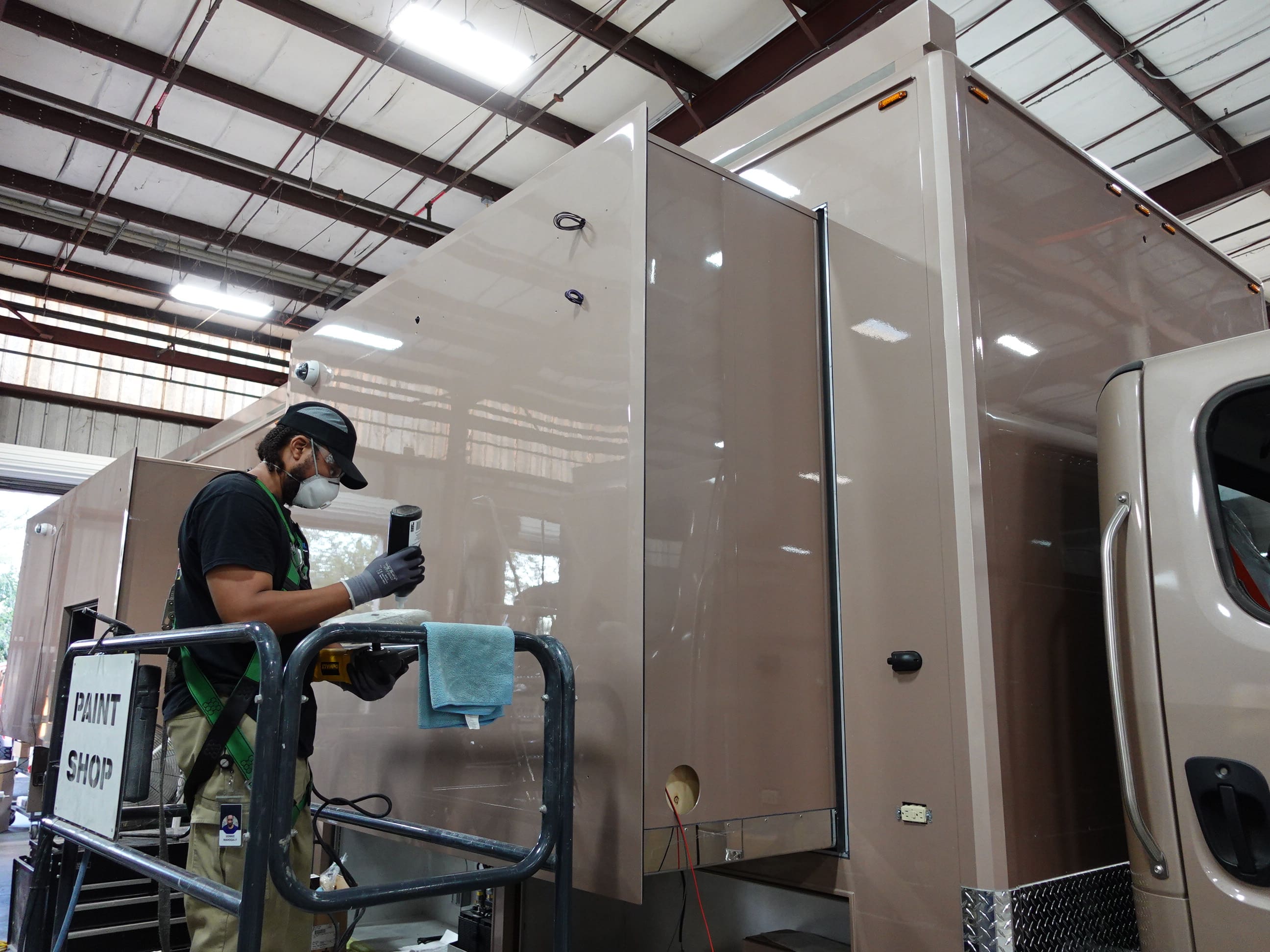

In this report, the apparatus continued assembly while the slide-outs completed fabrication and began the paint process.

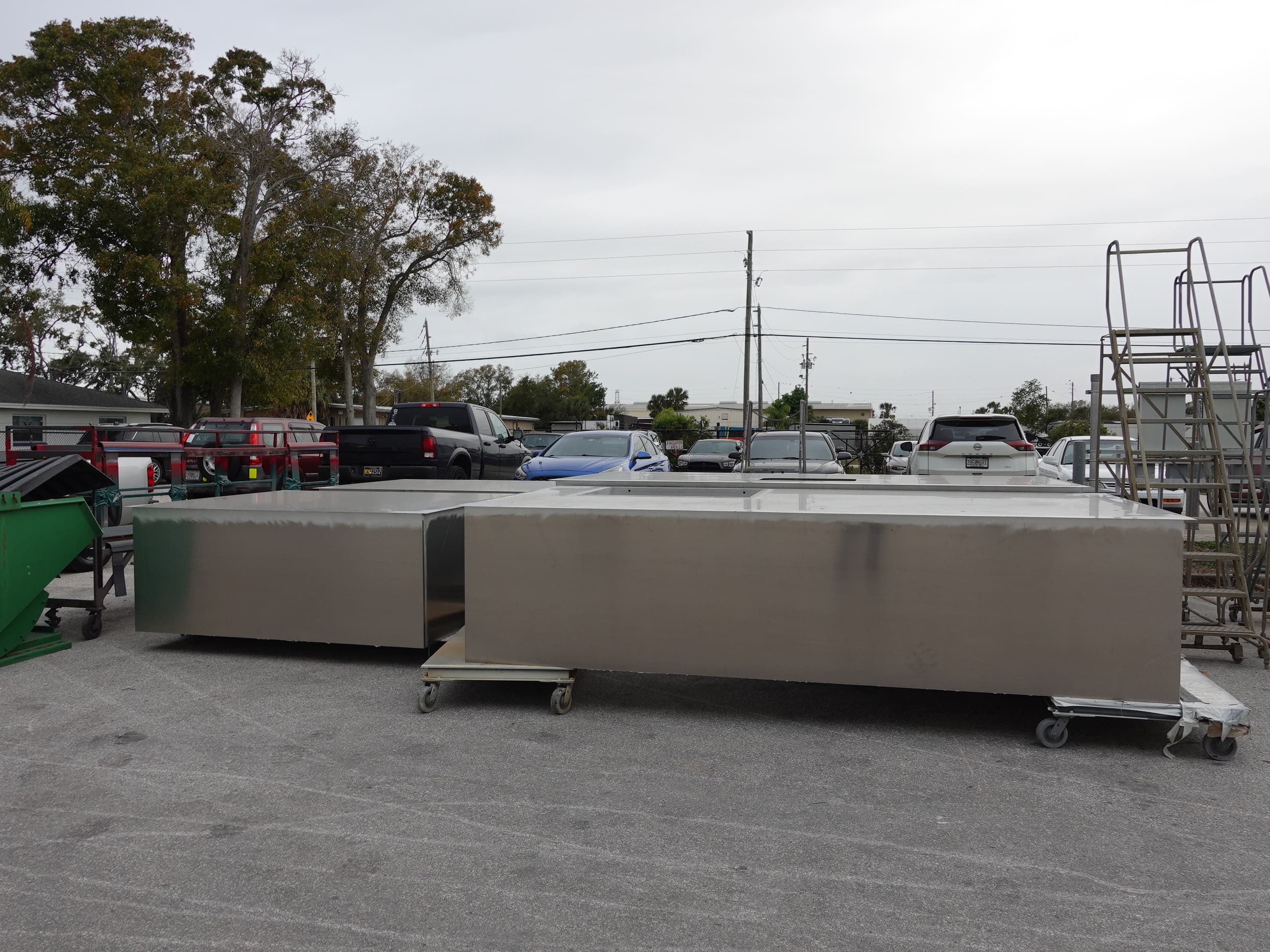

01-30-26

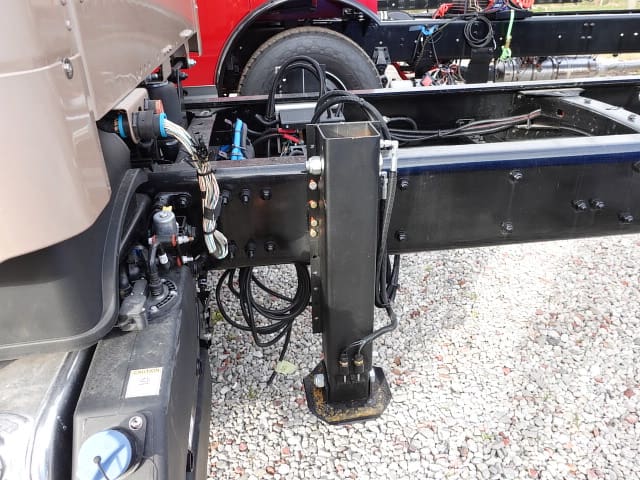

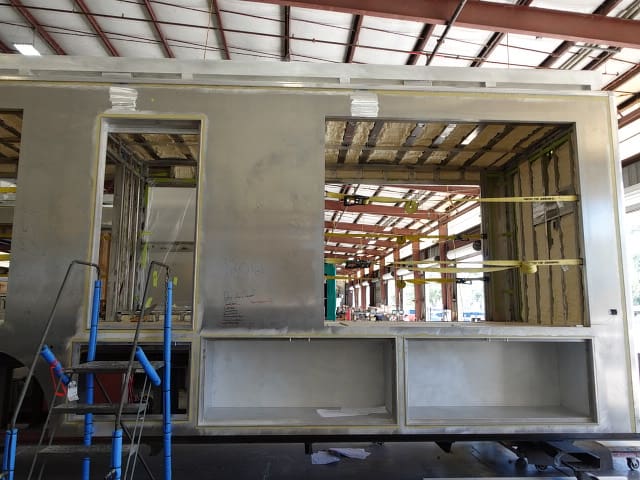

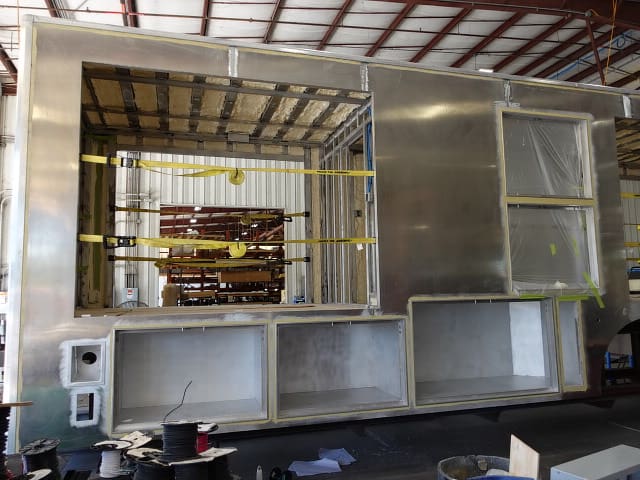

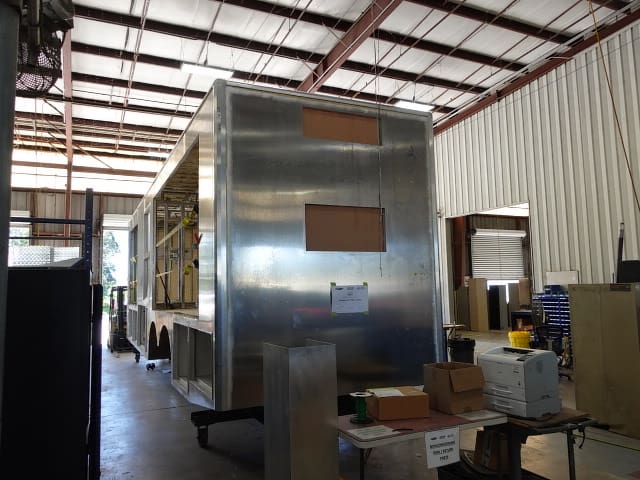

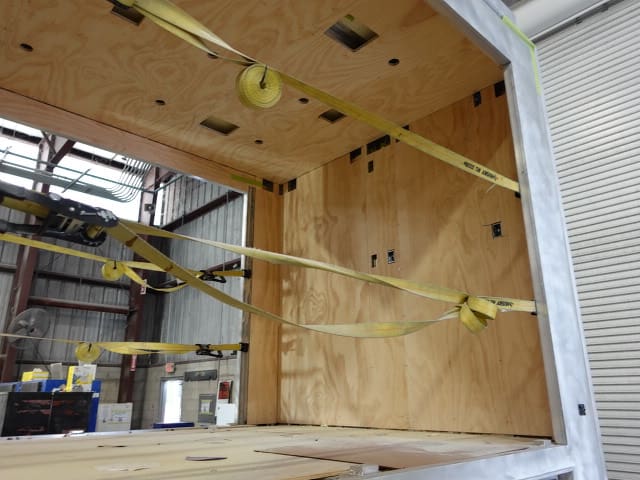

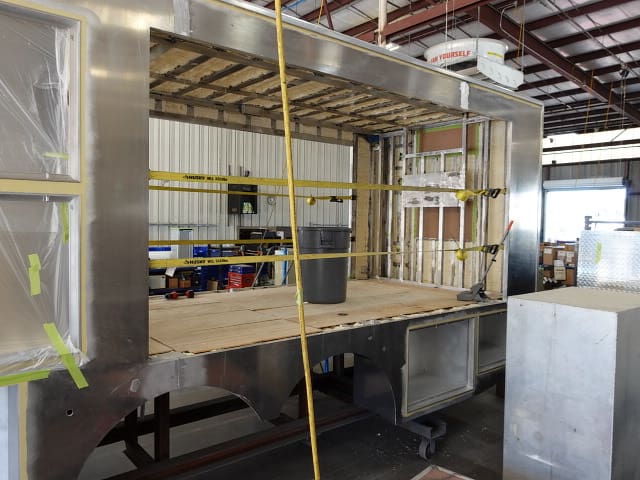

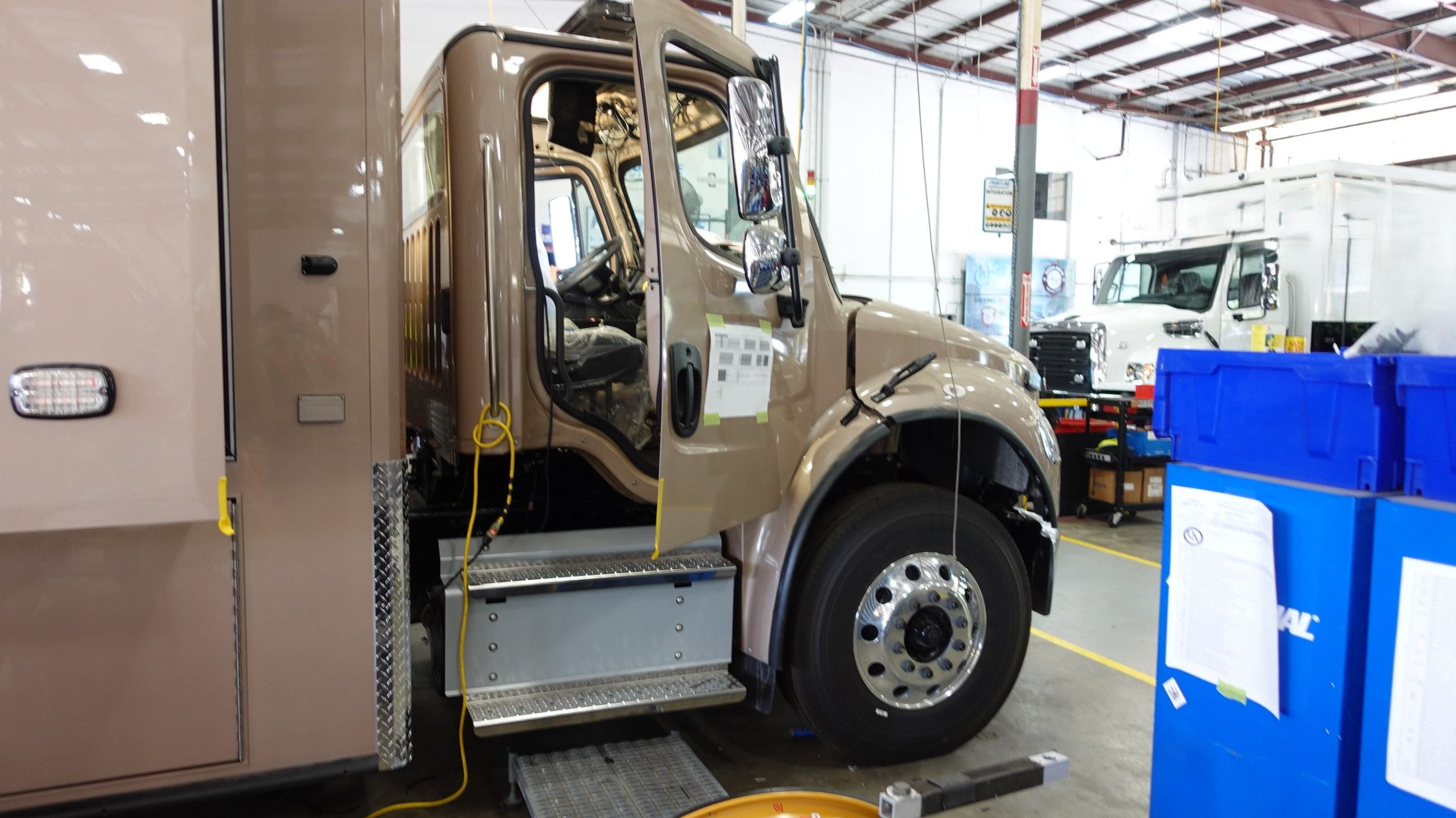

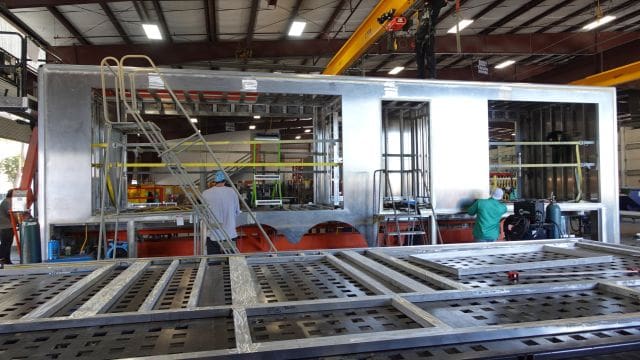

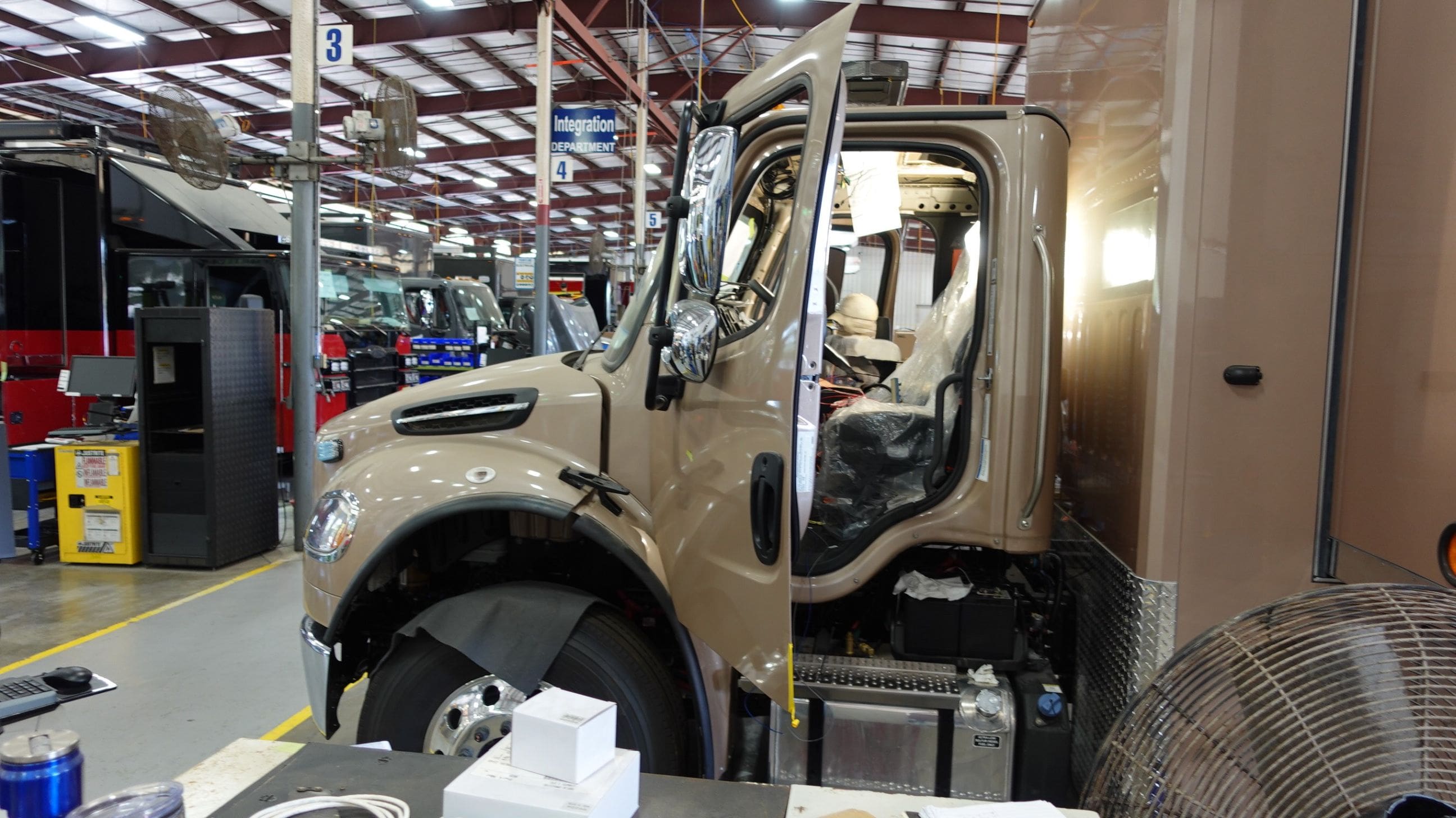

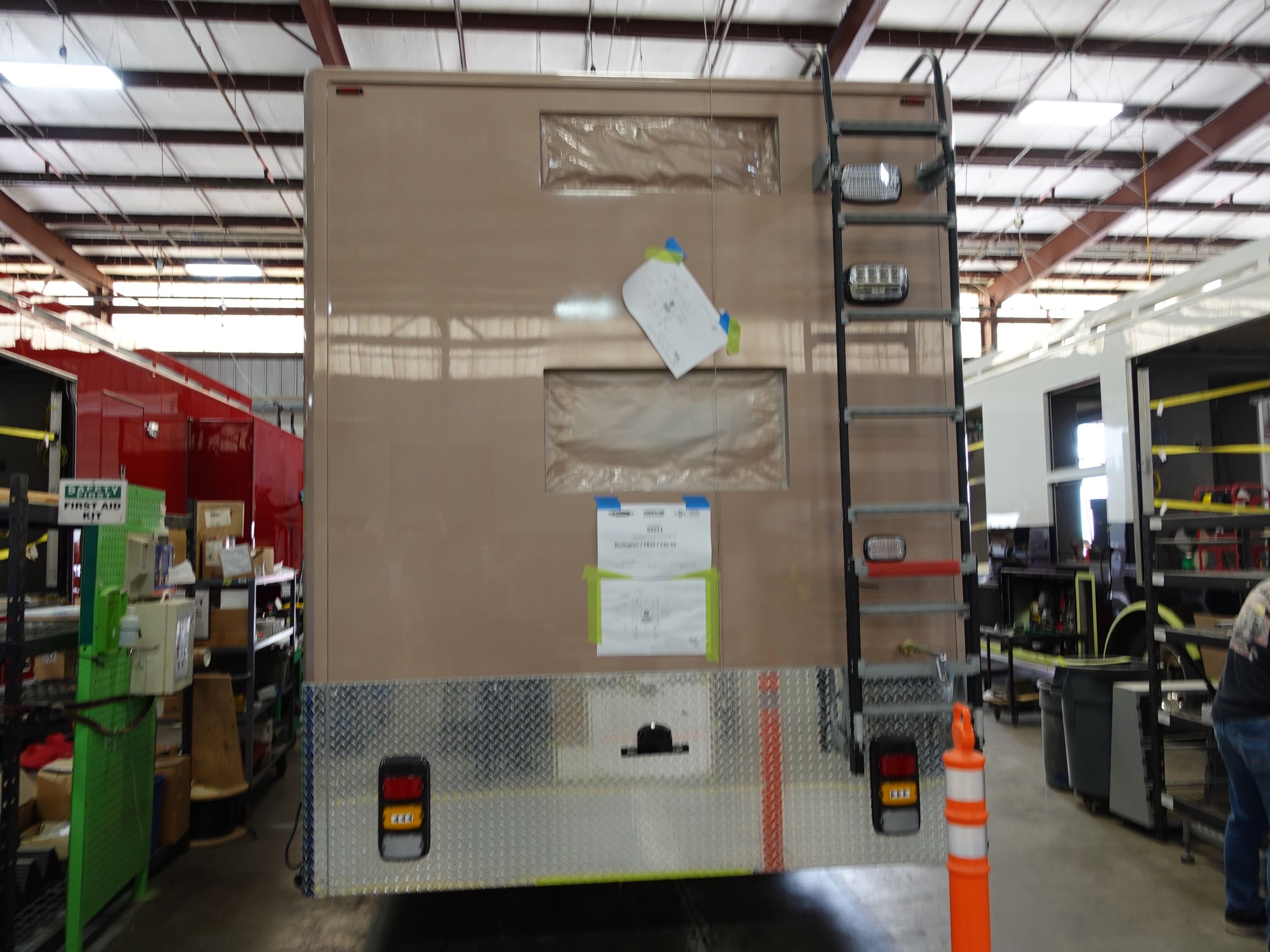

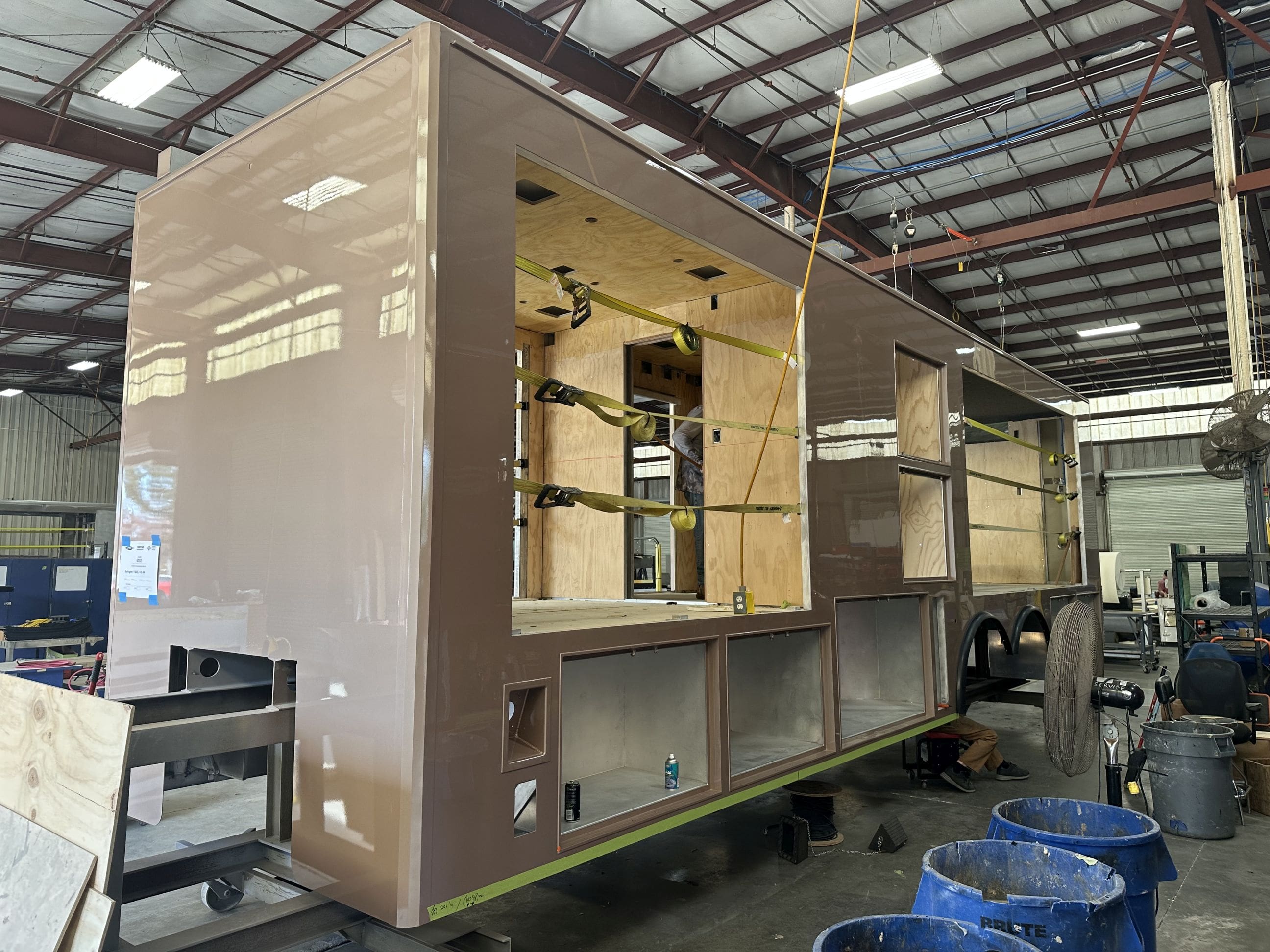

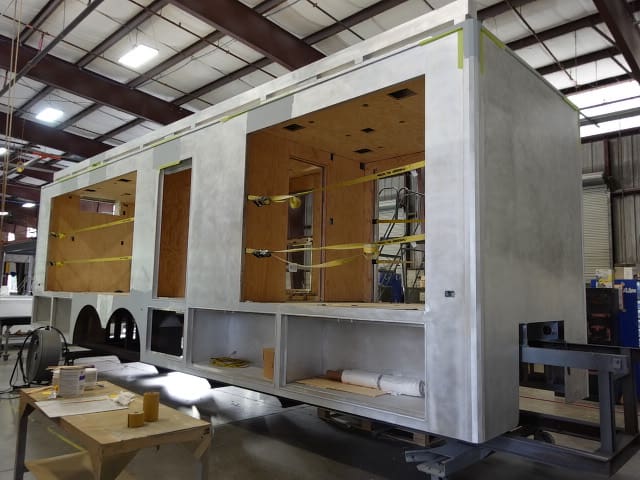

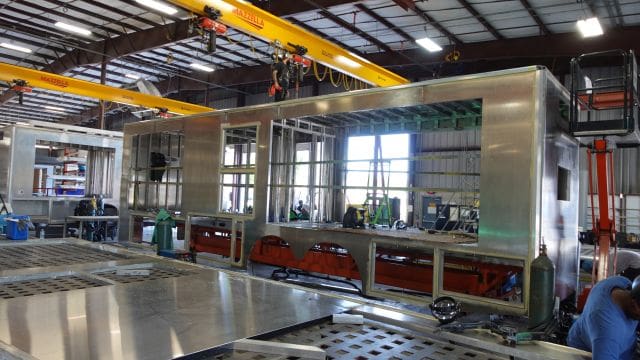

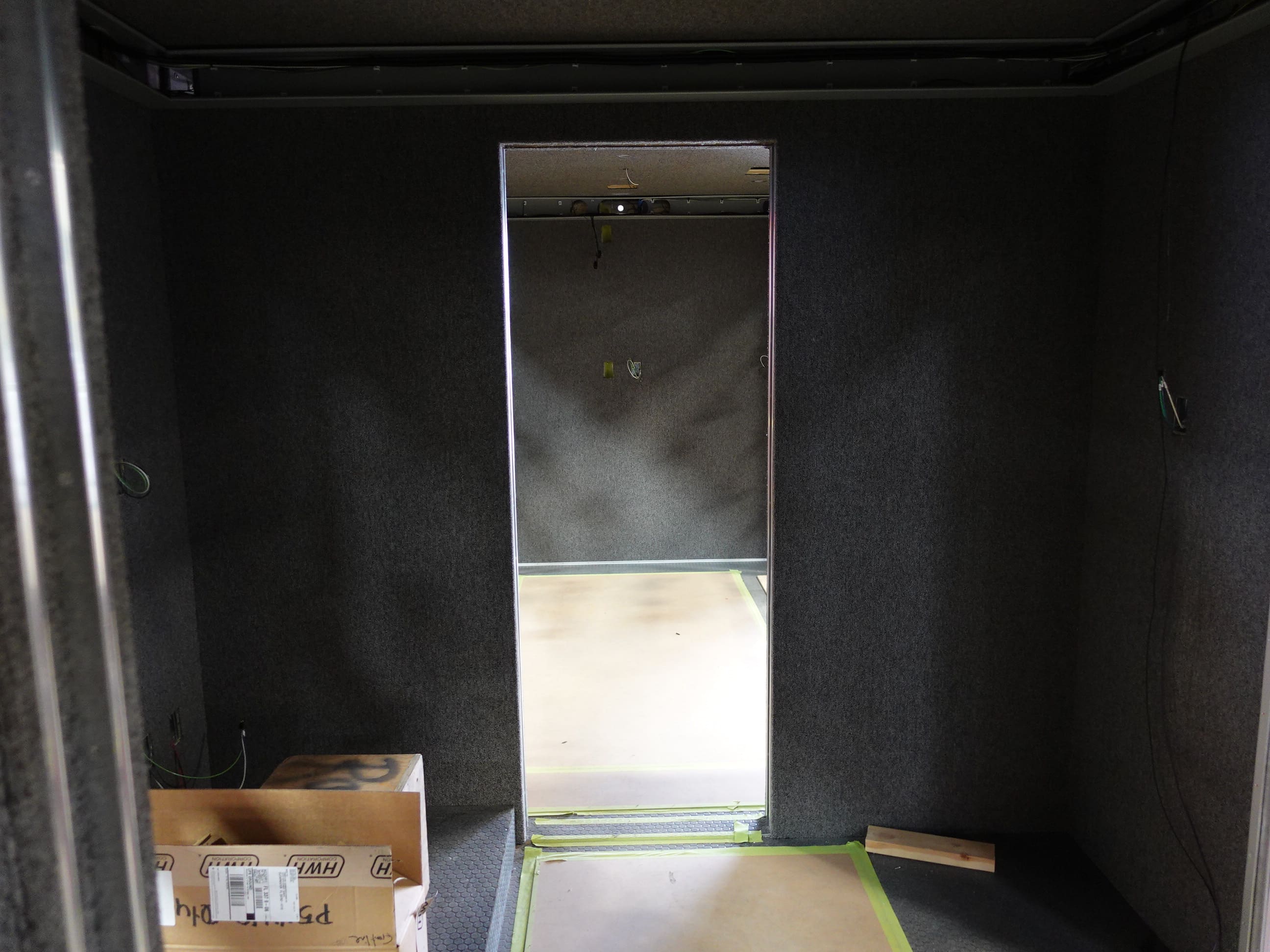

In this report, the body was merged with the chassis while assembly continue, and the slide-outs continued fabrication.
01-09-26

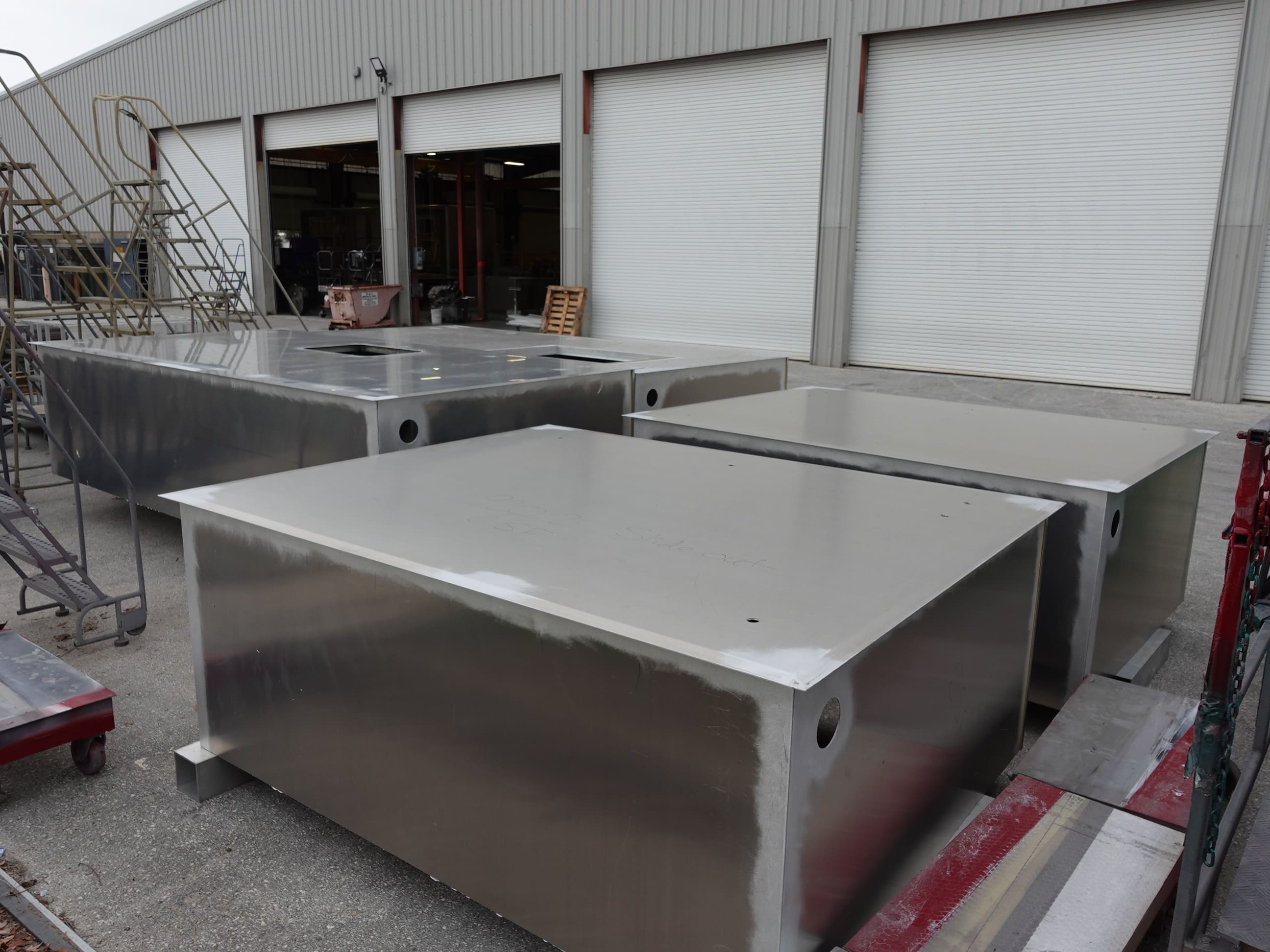

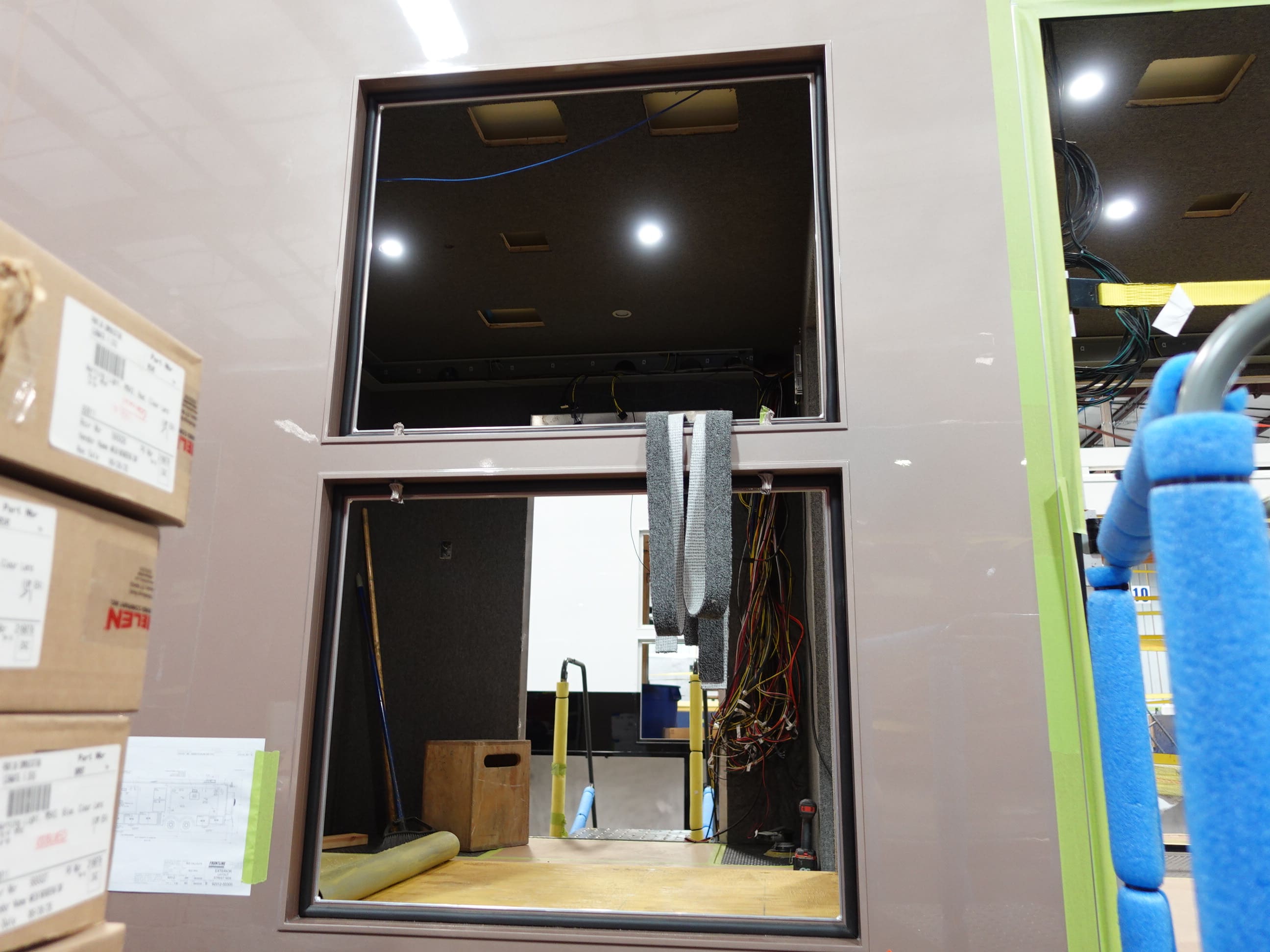

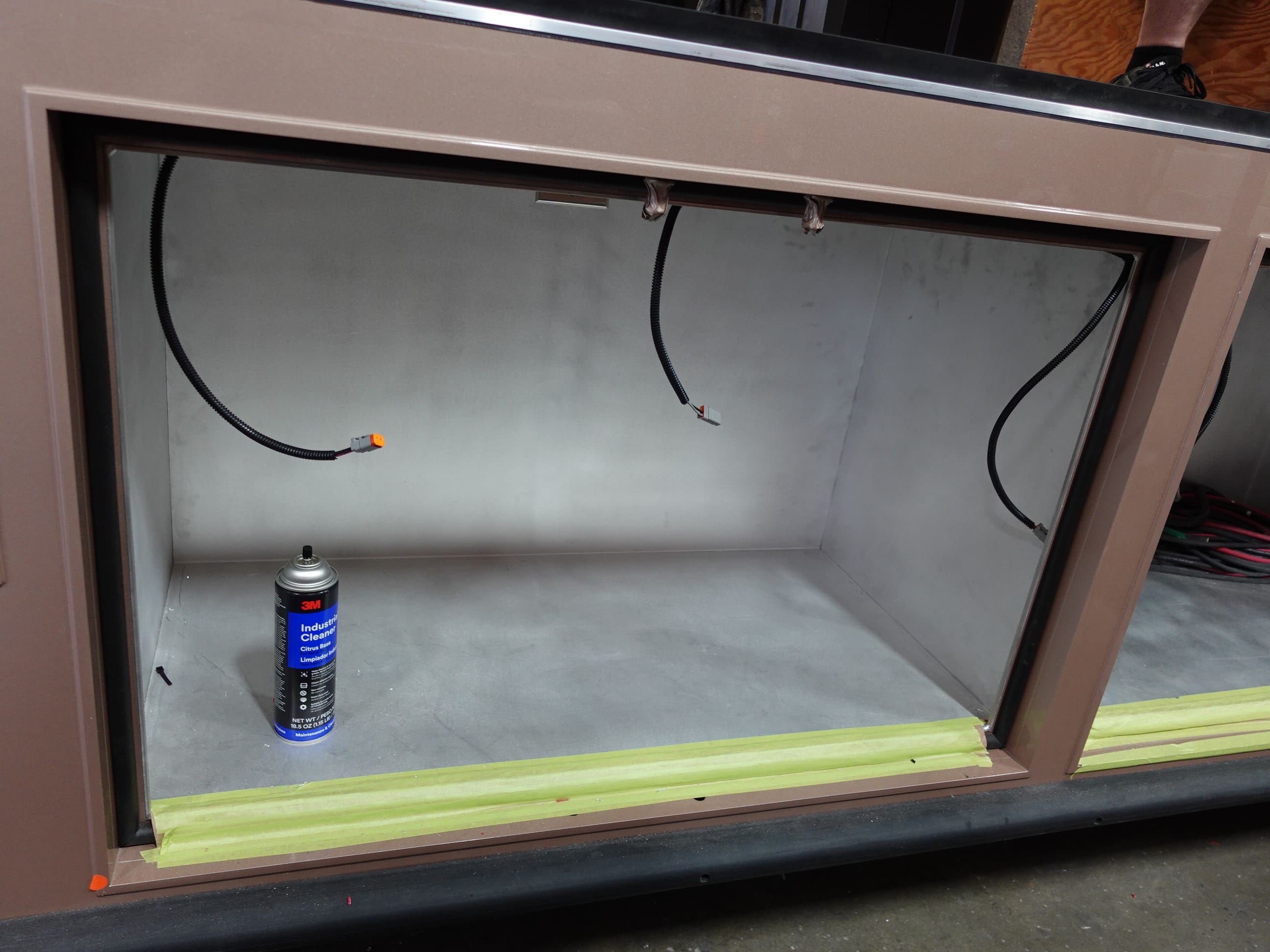

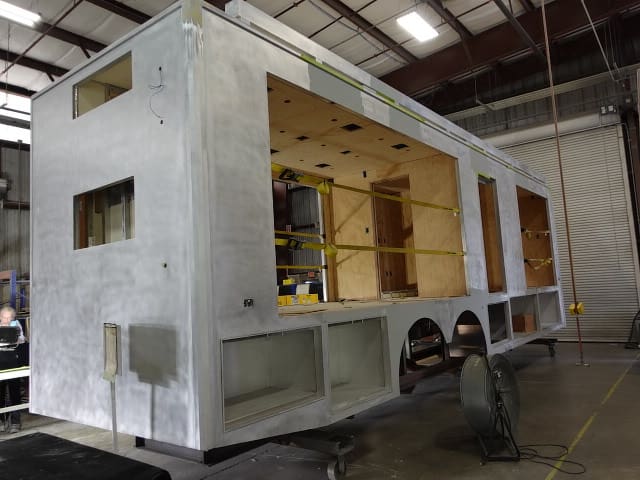

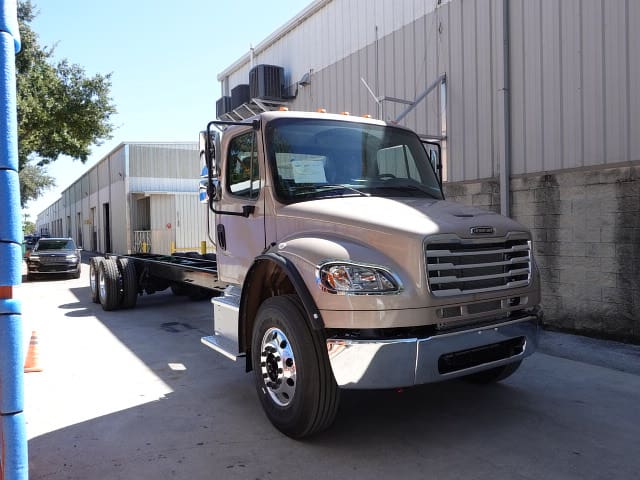

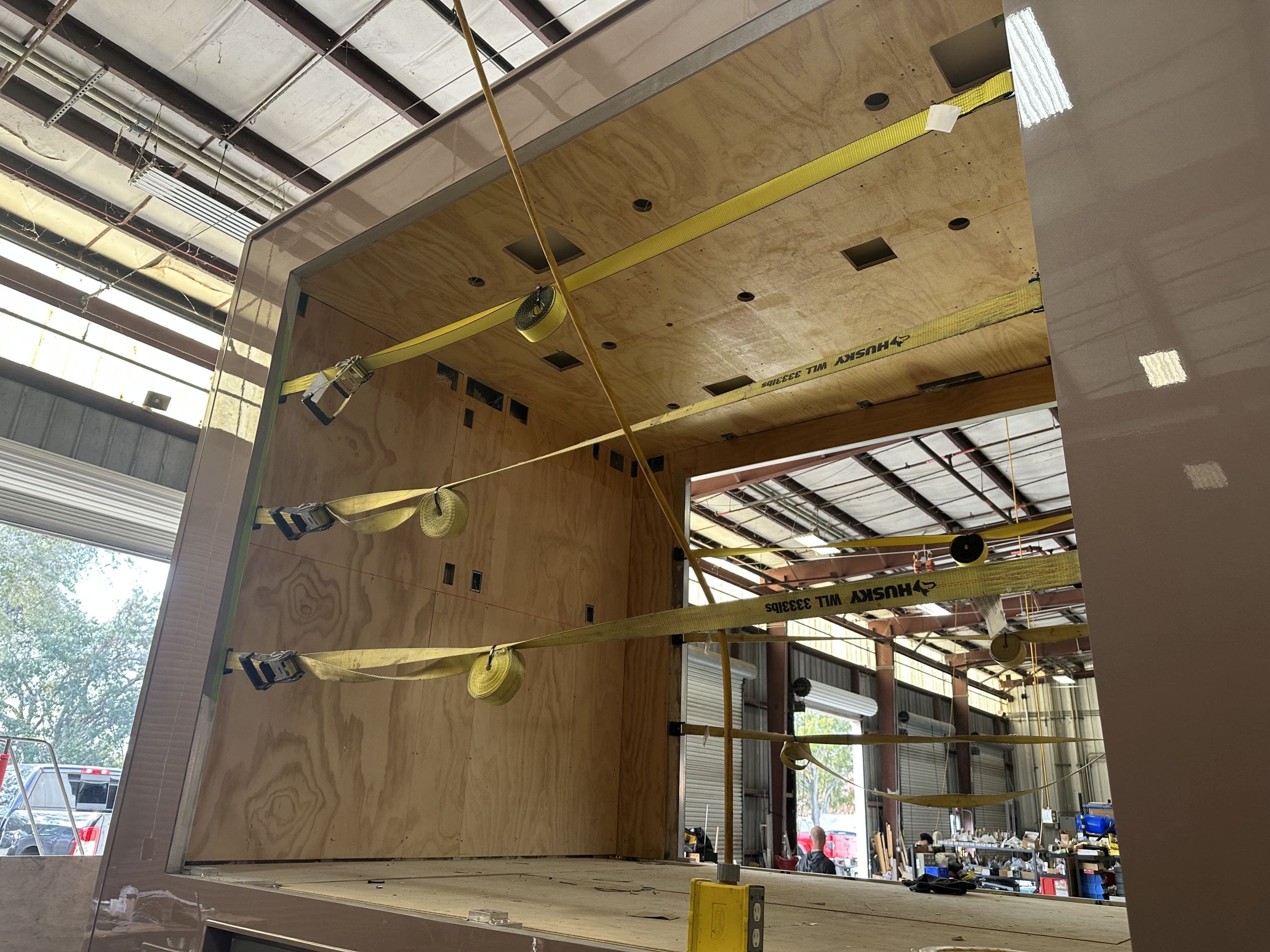

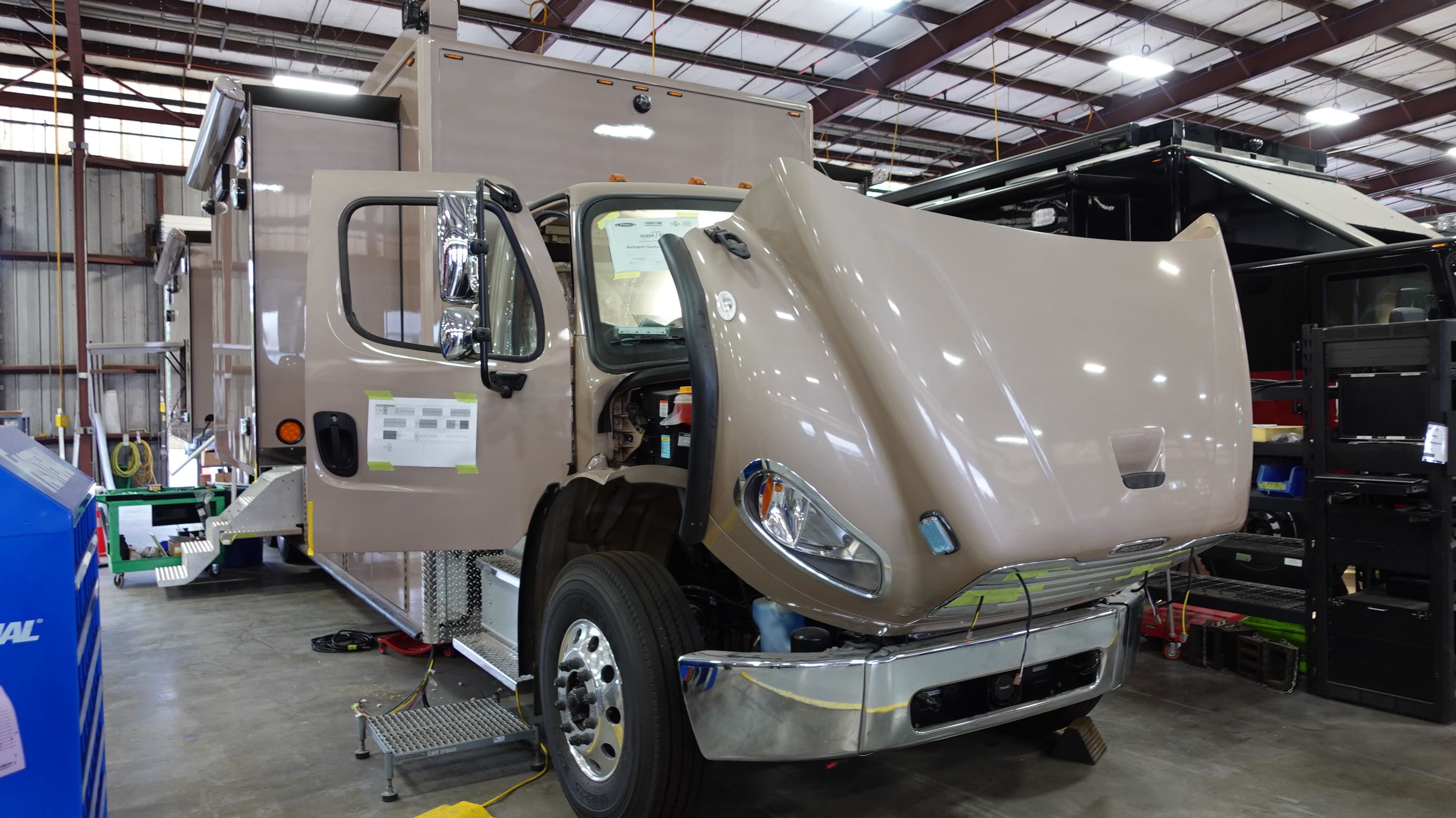

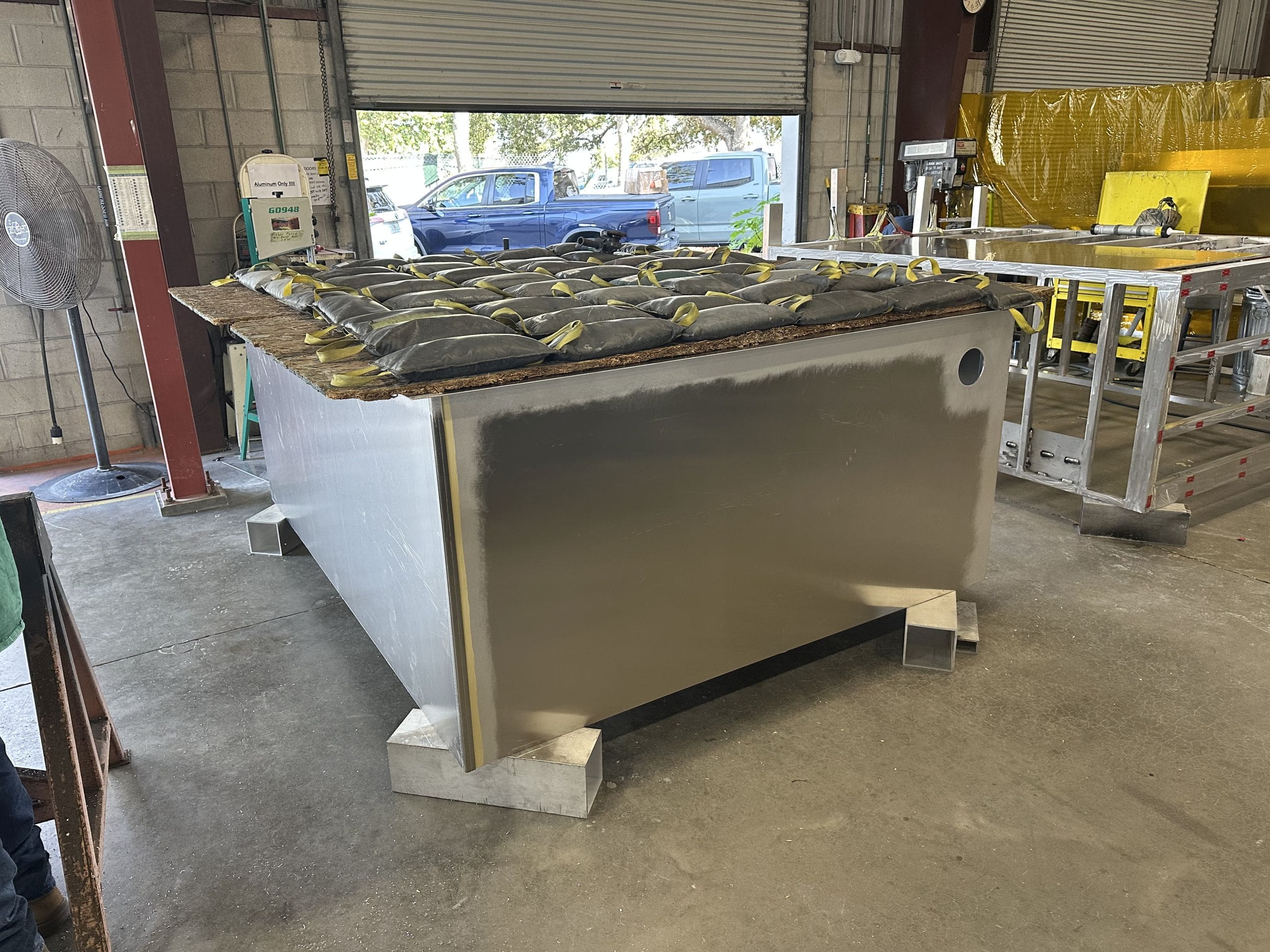

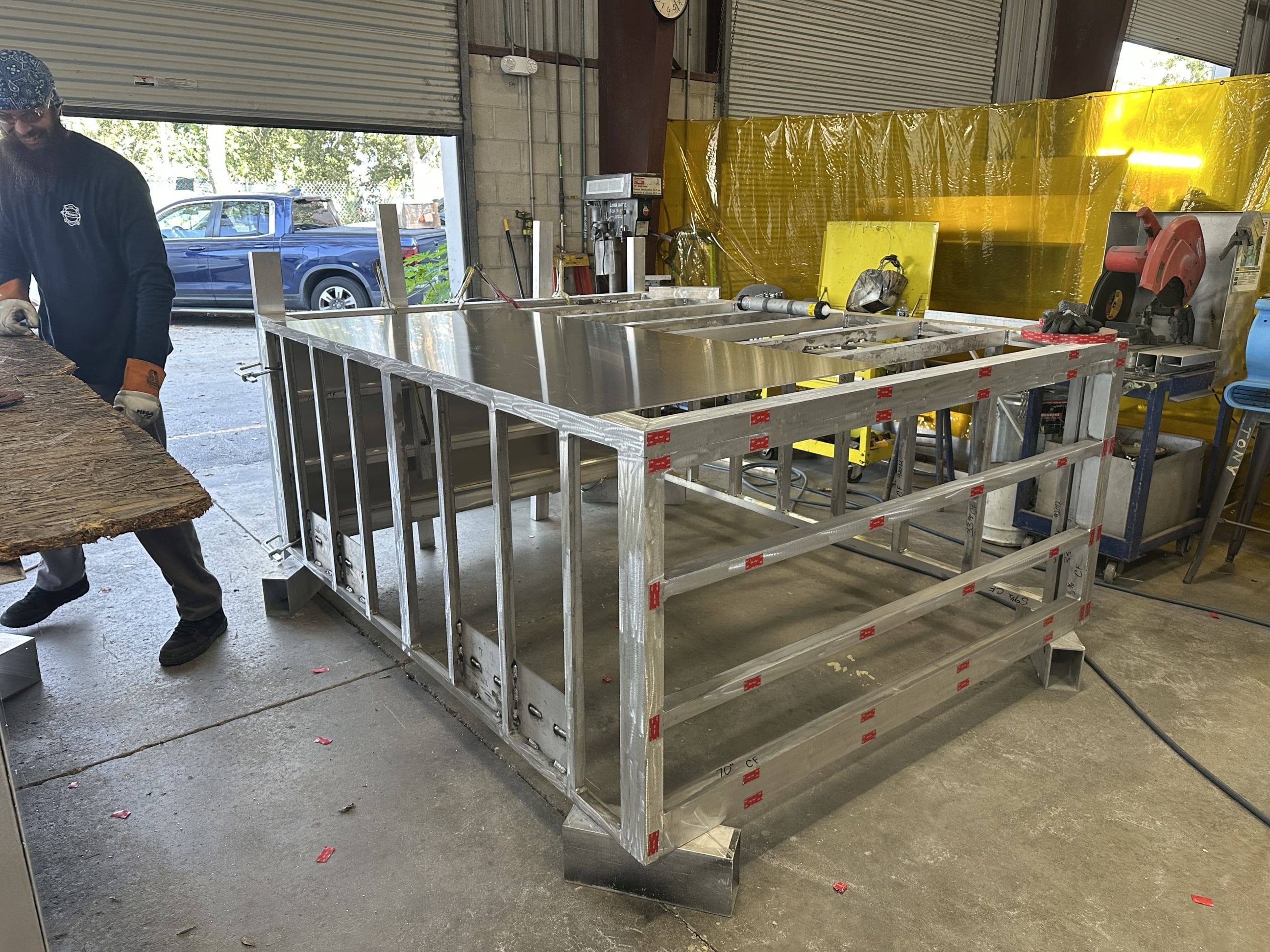

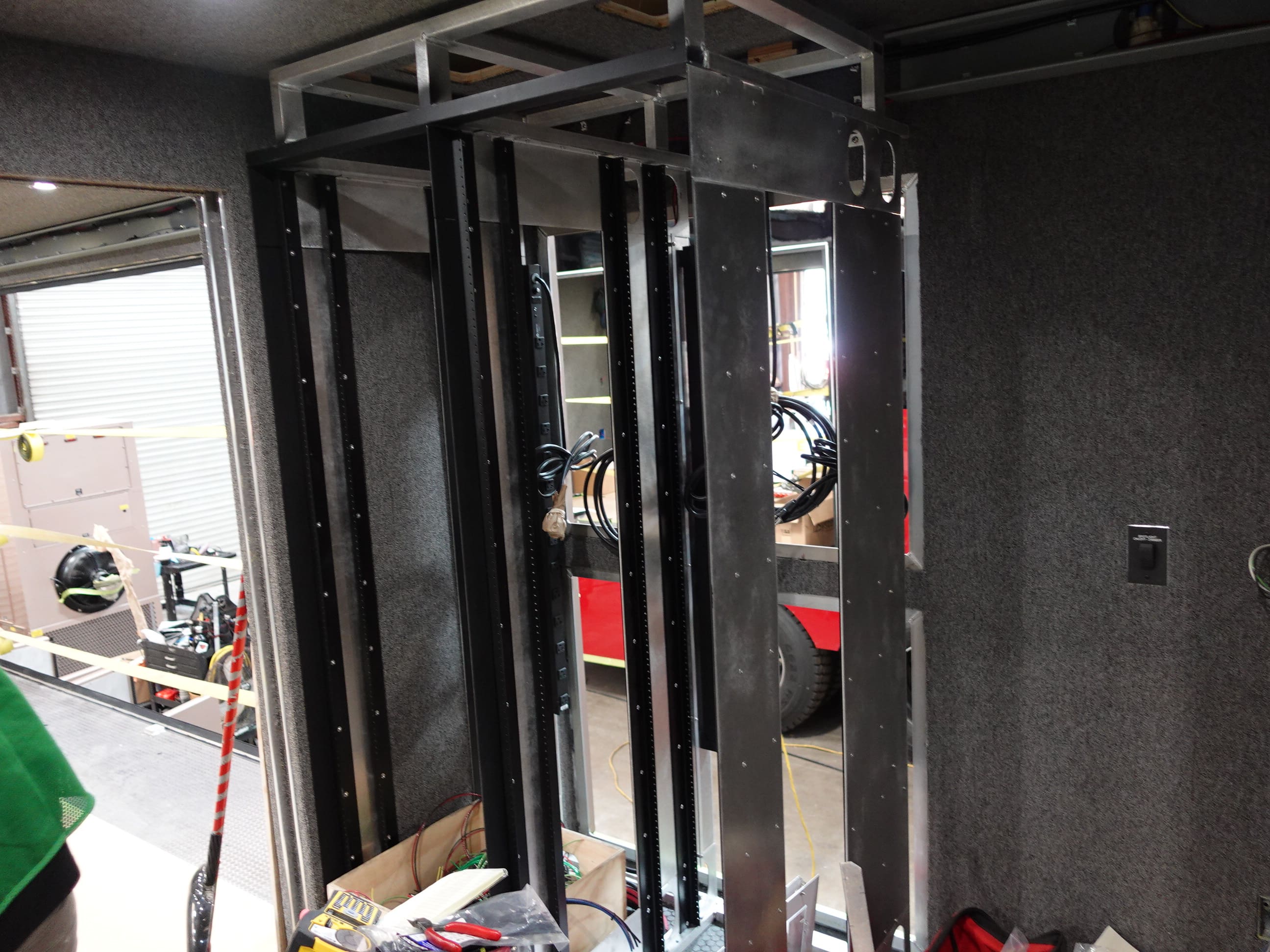

In this report, the chassis was staged to continue preparation, the body completed paint and began initial assembly, and the slide-outs began fabrication.

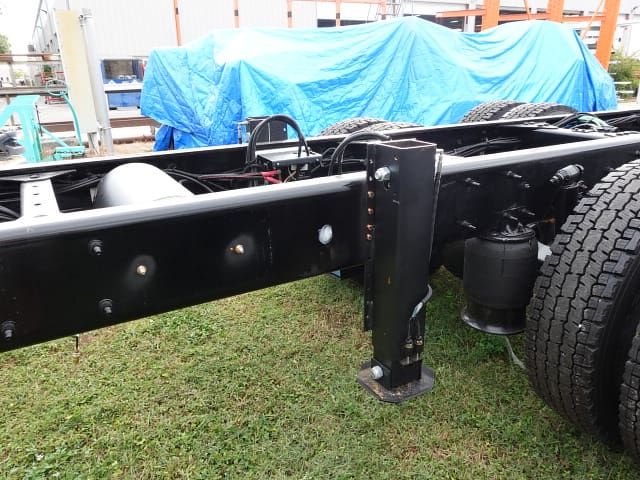

12-05-25

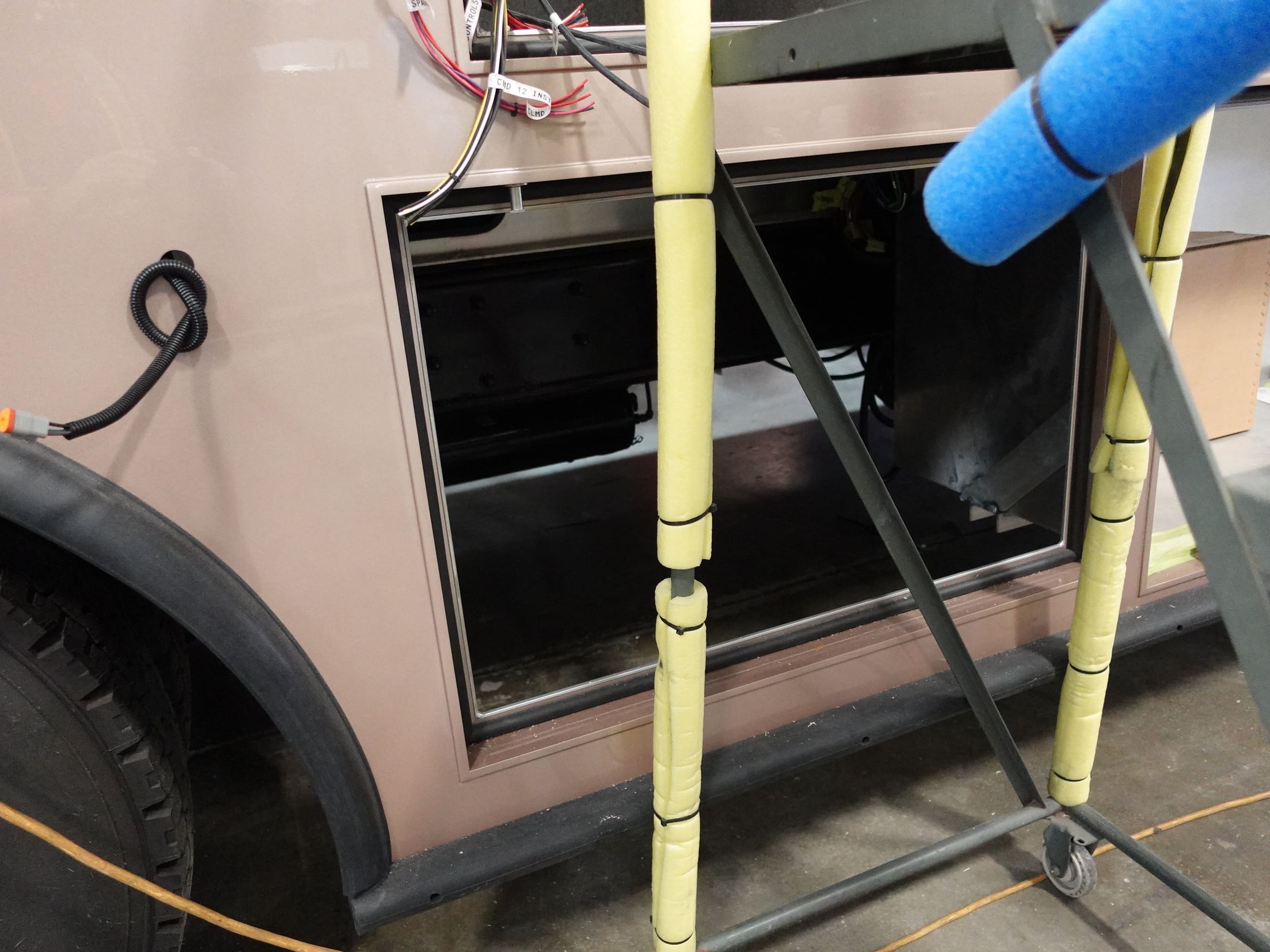

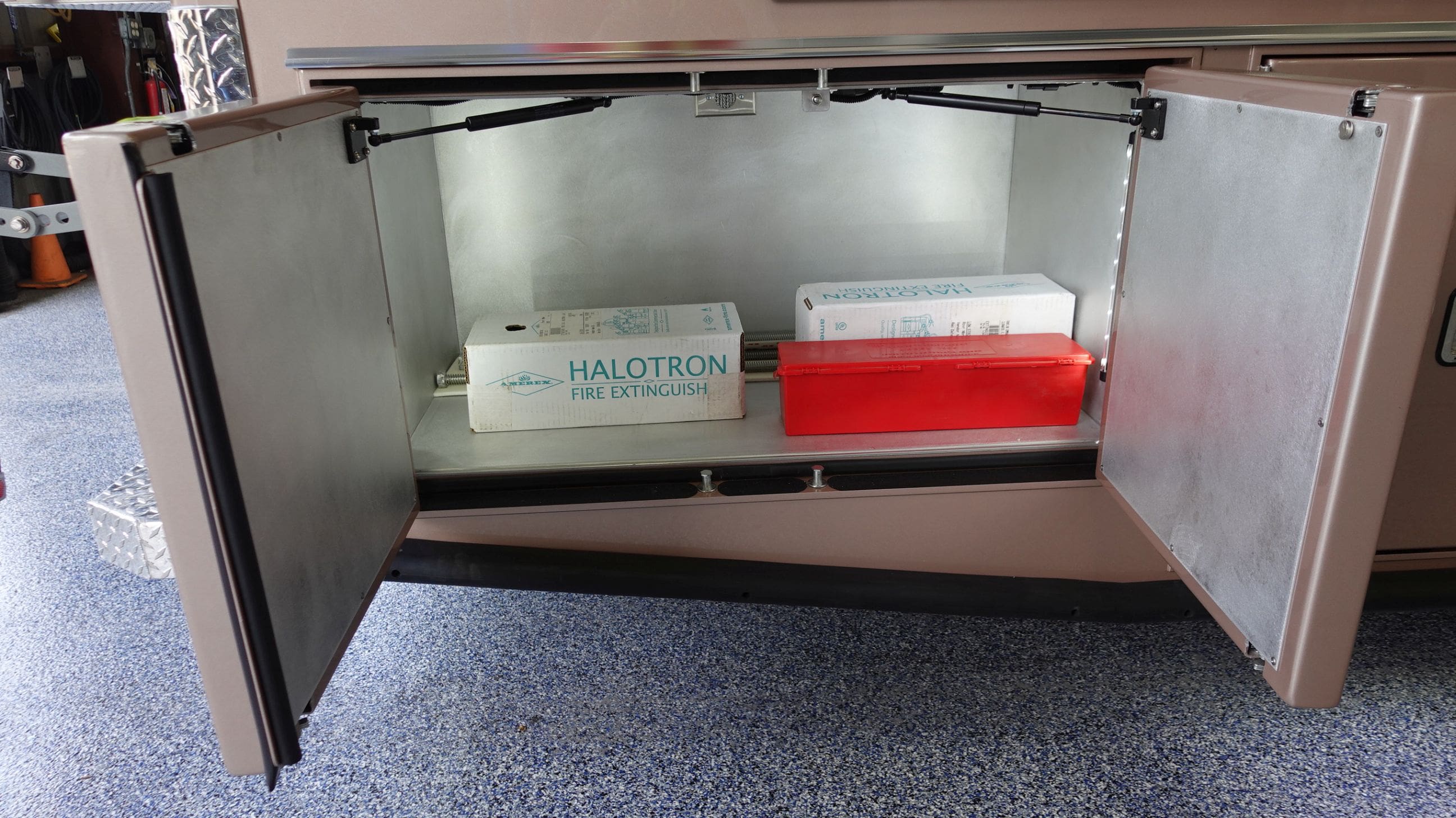

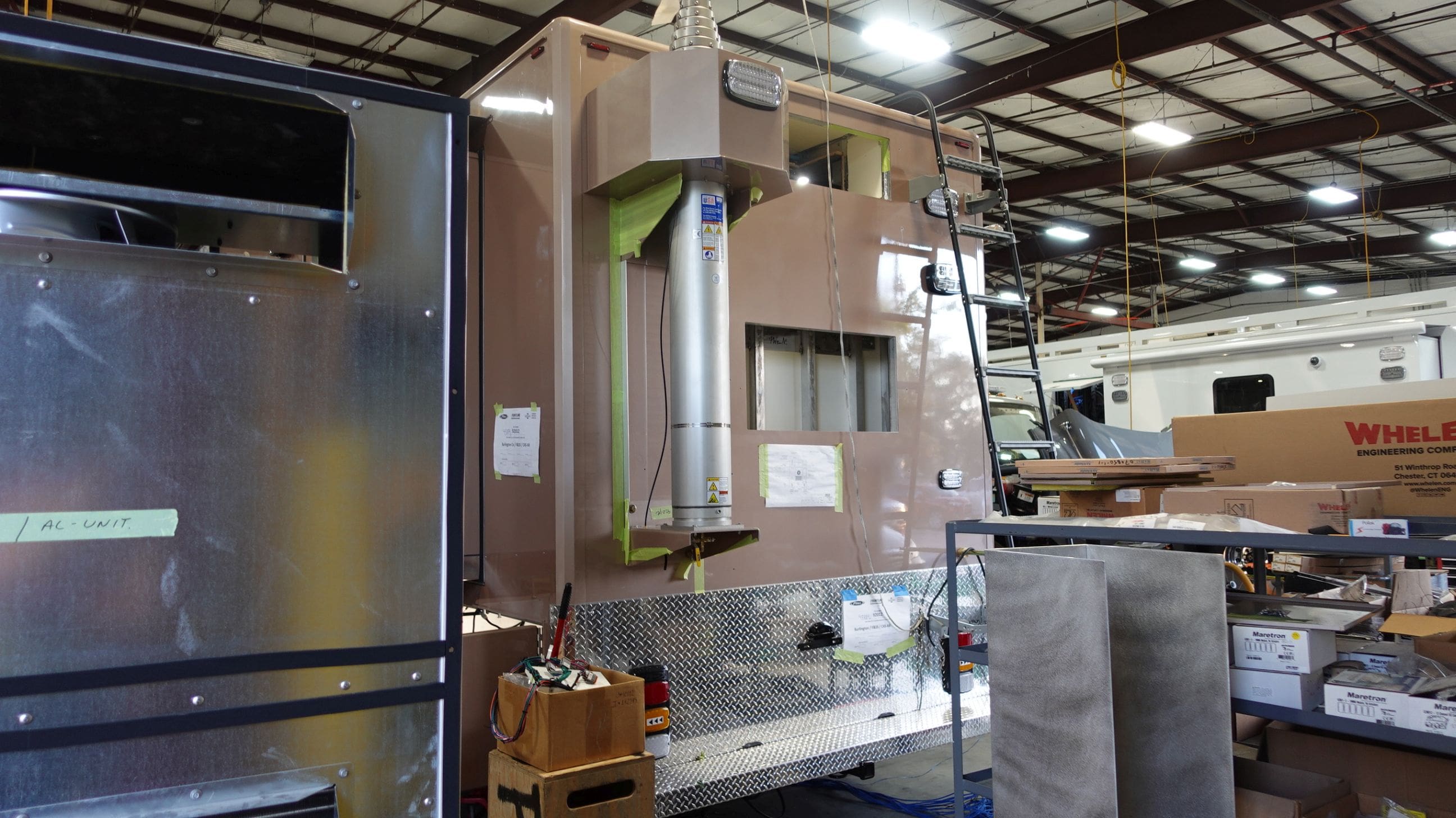

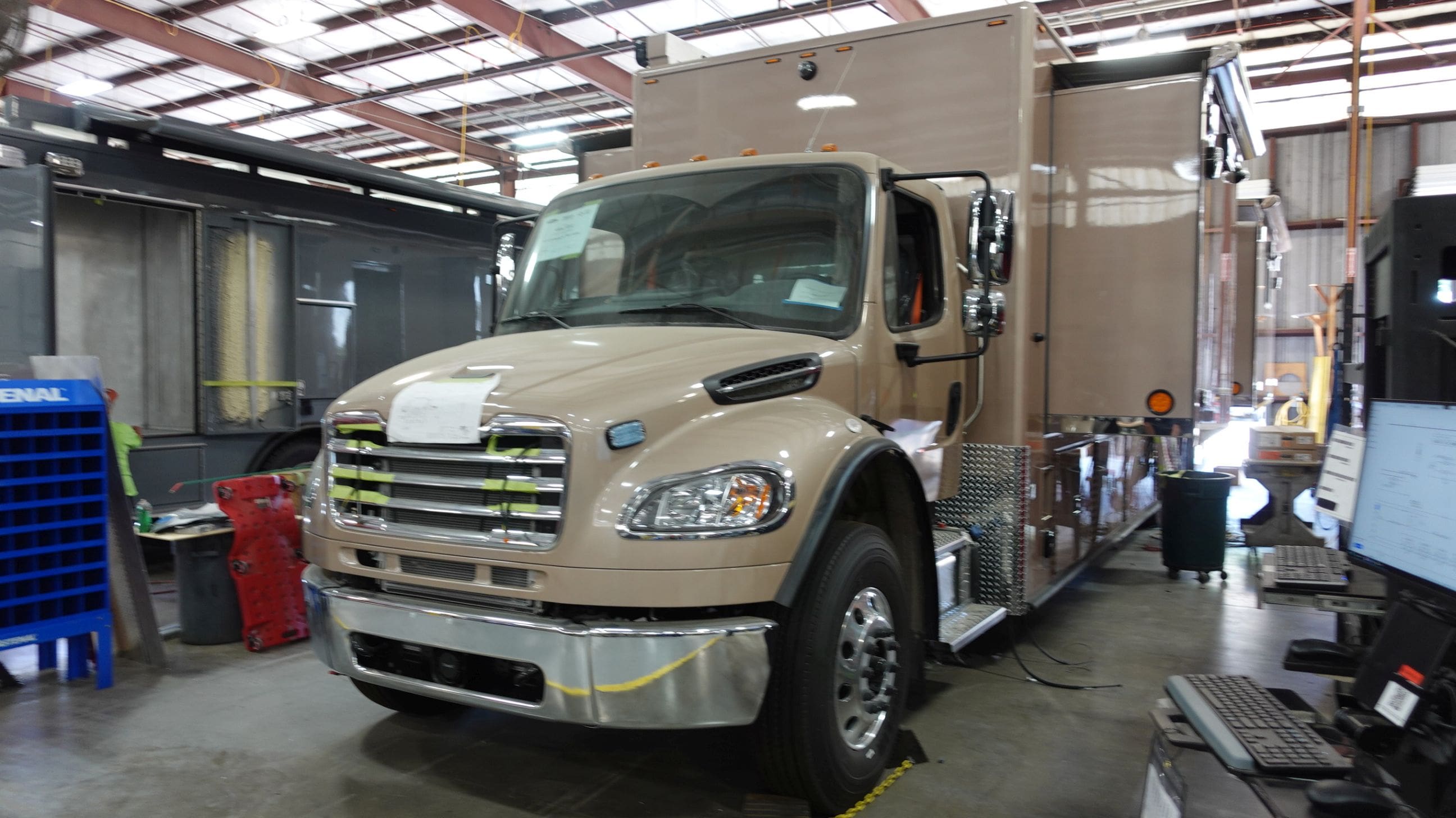

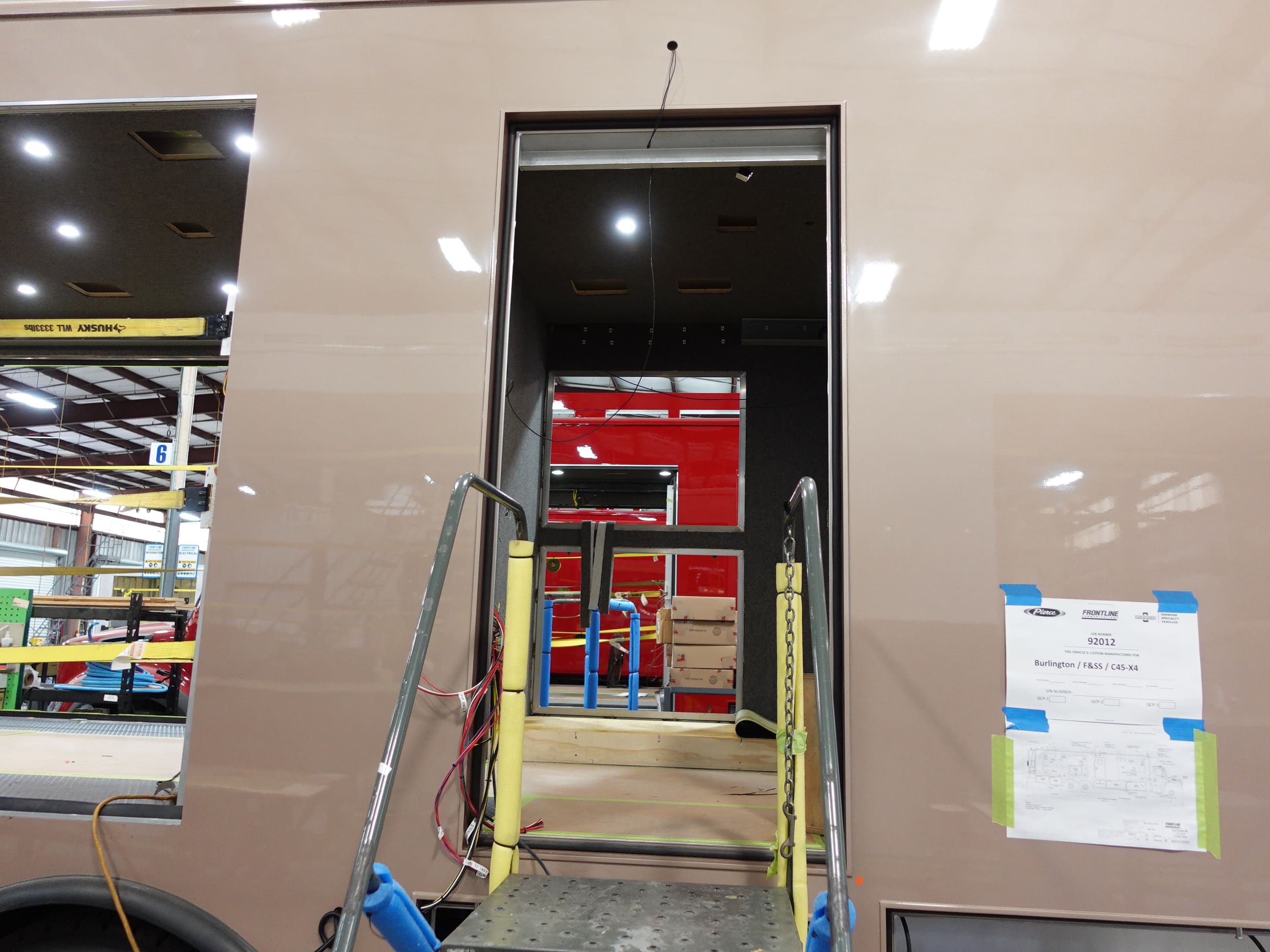

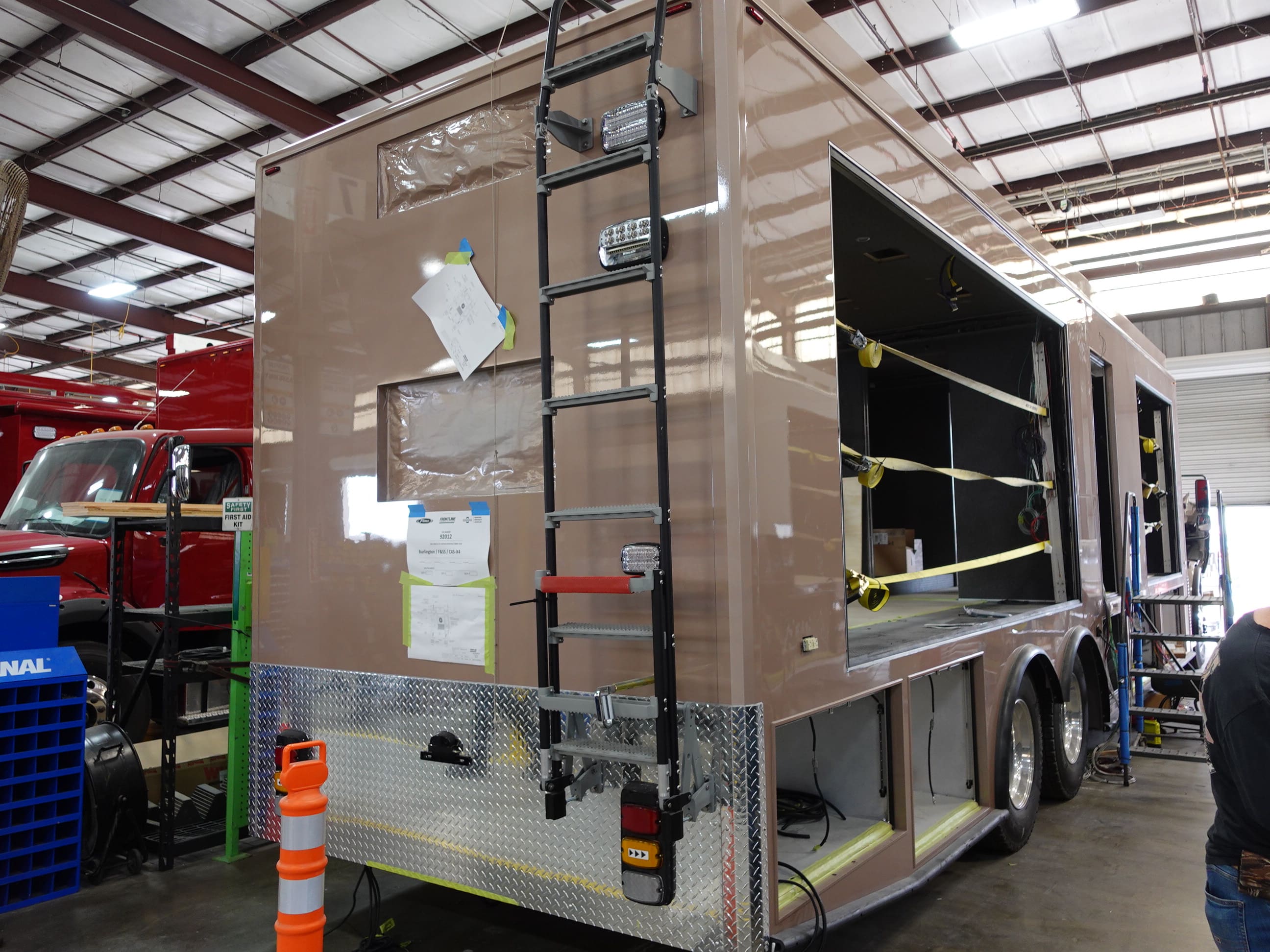

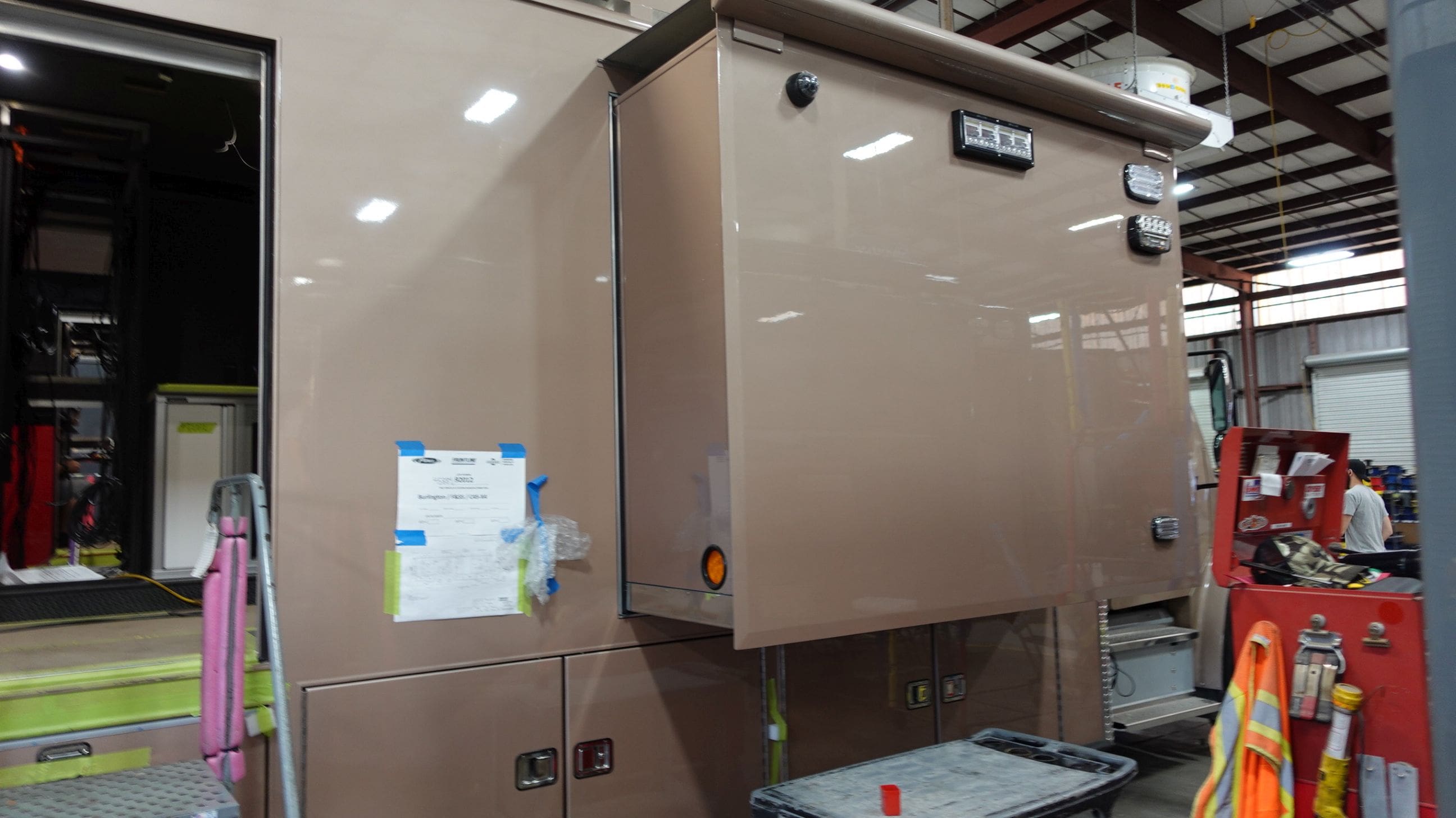

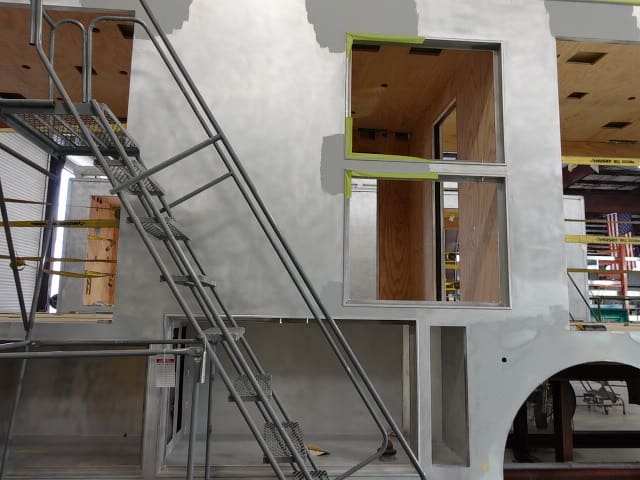

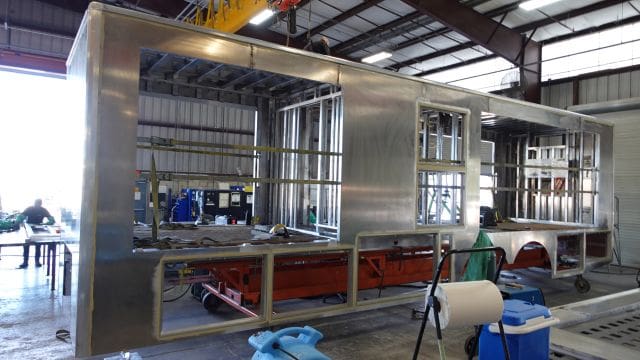

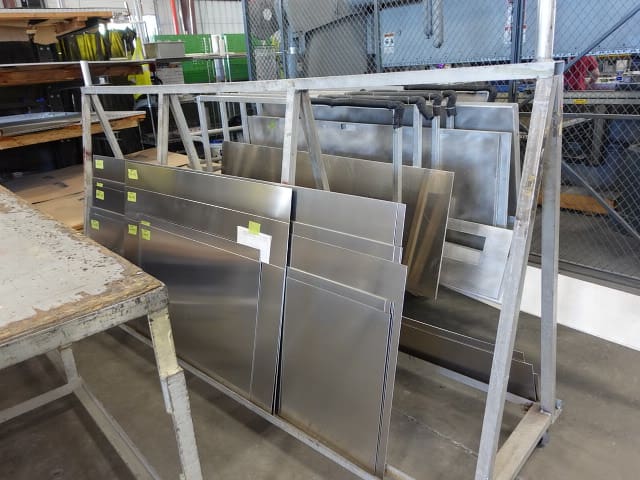

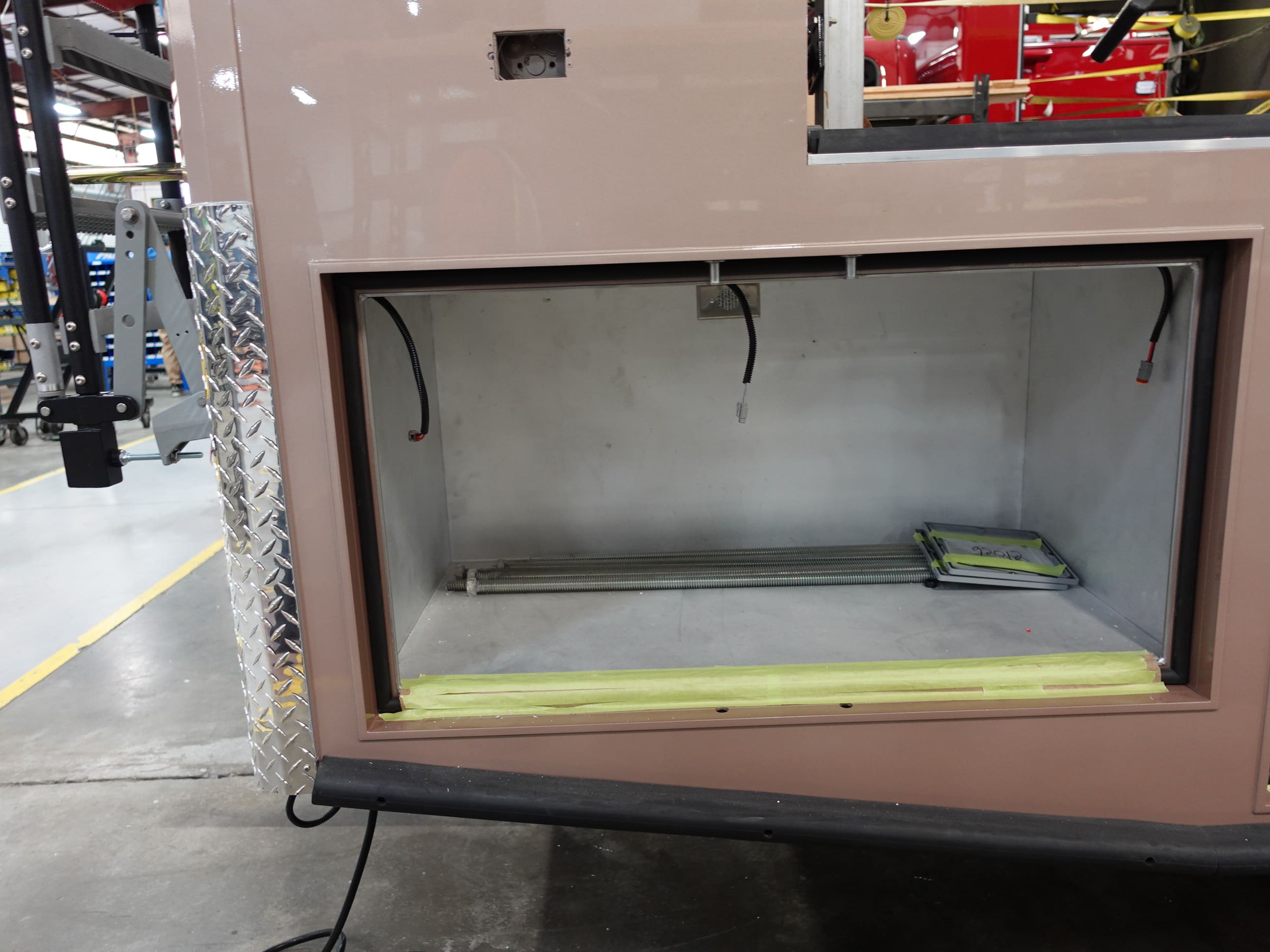

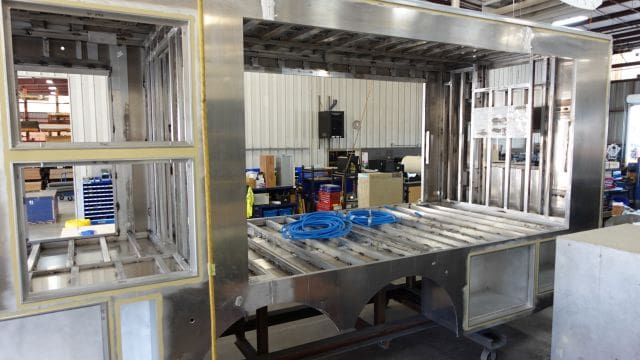

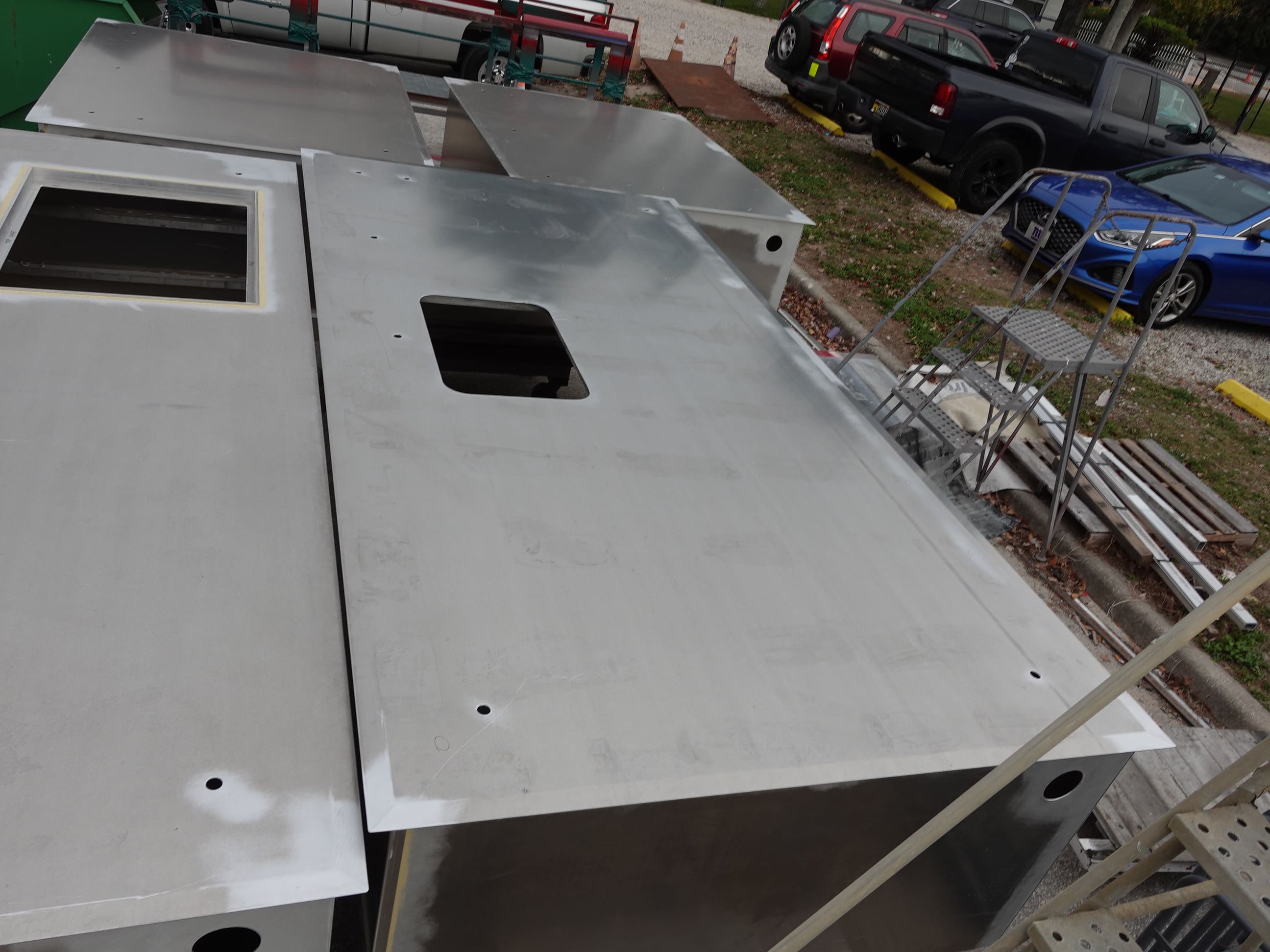

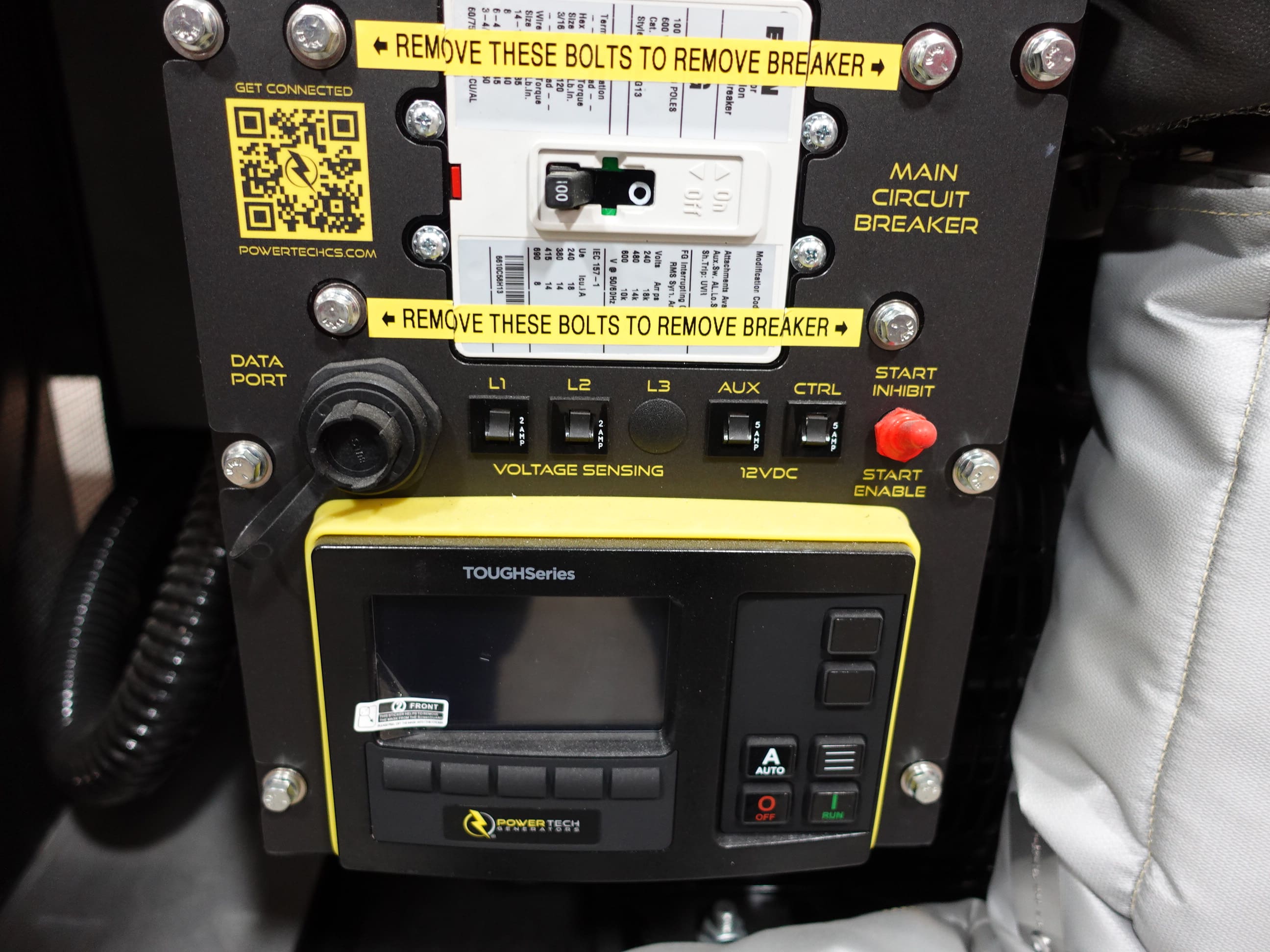

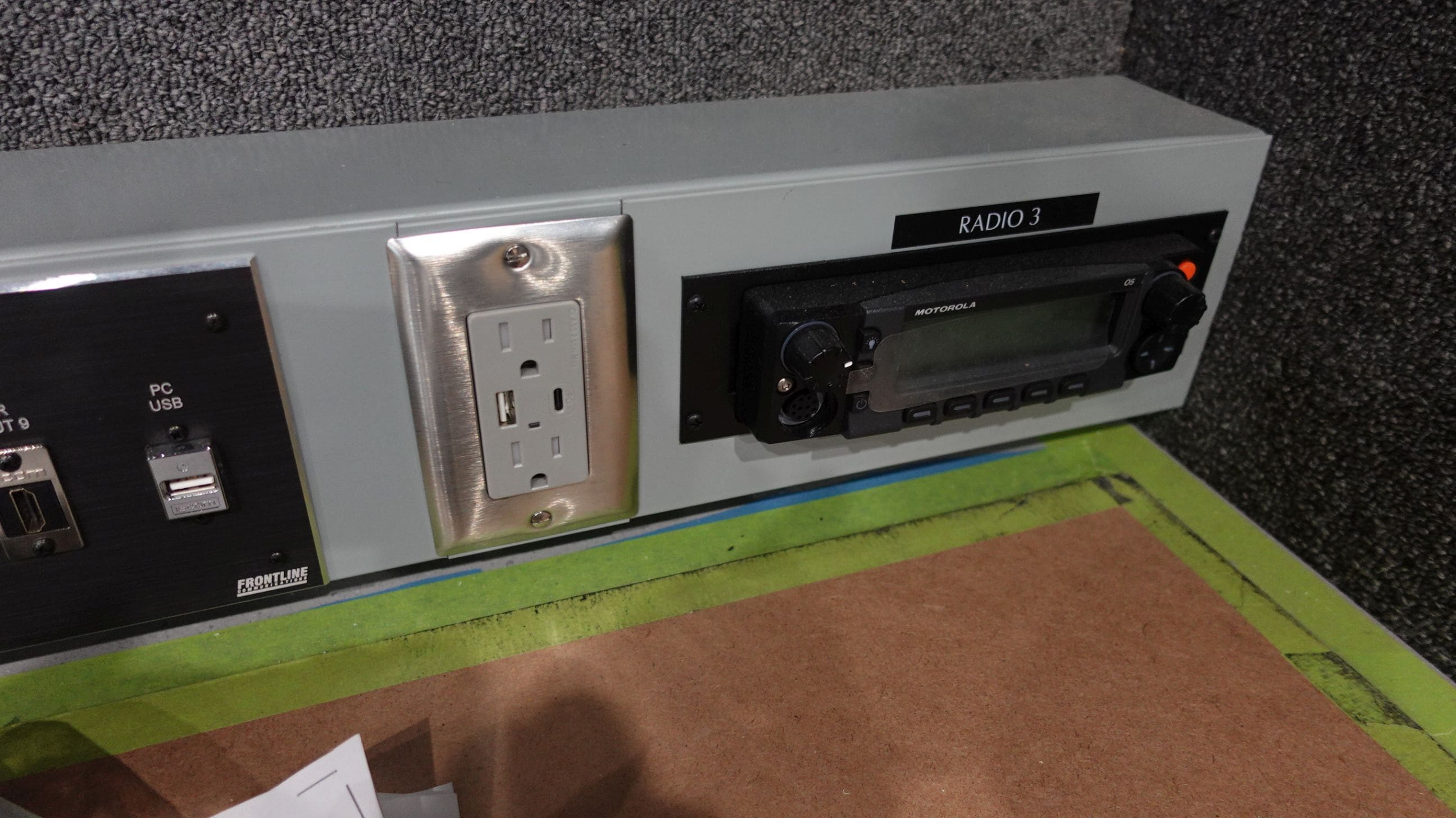

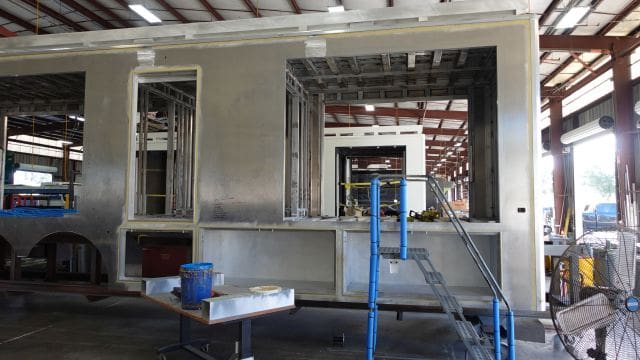

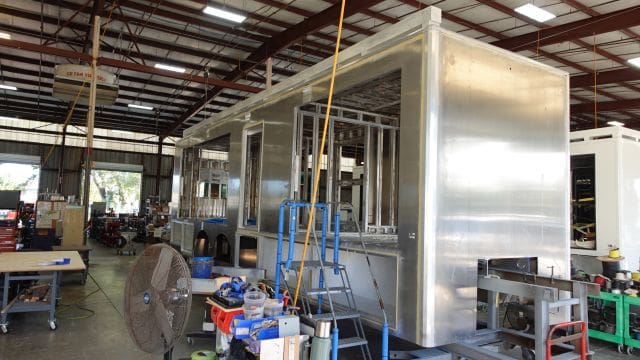

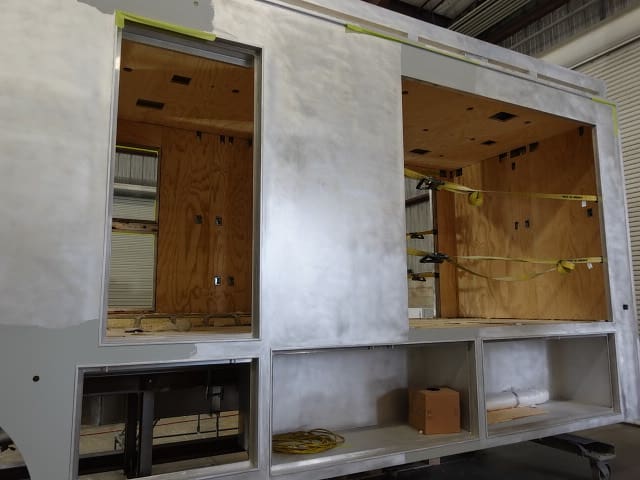

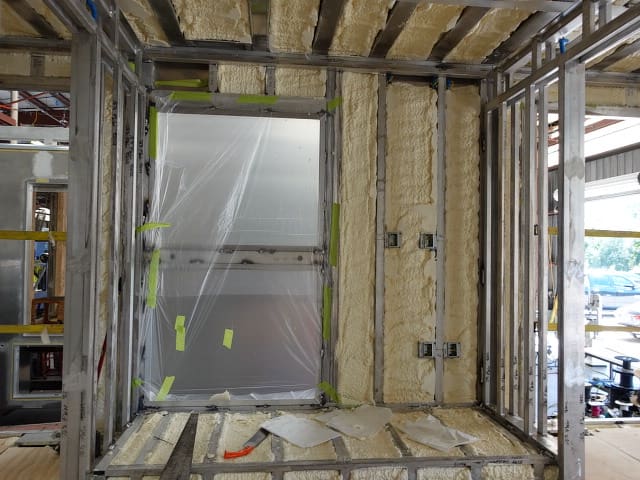

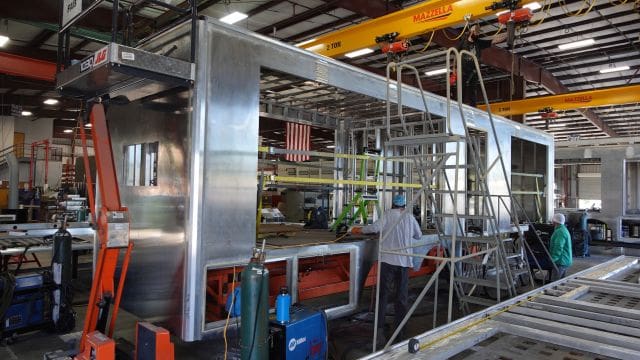

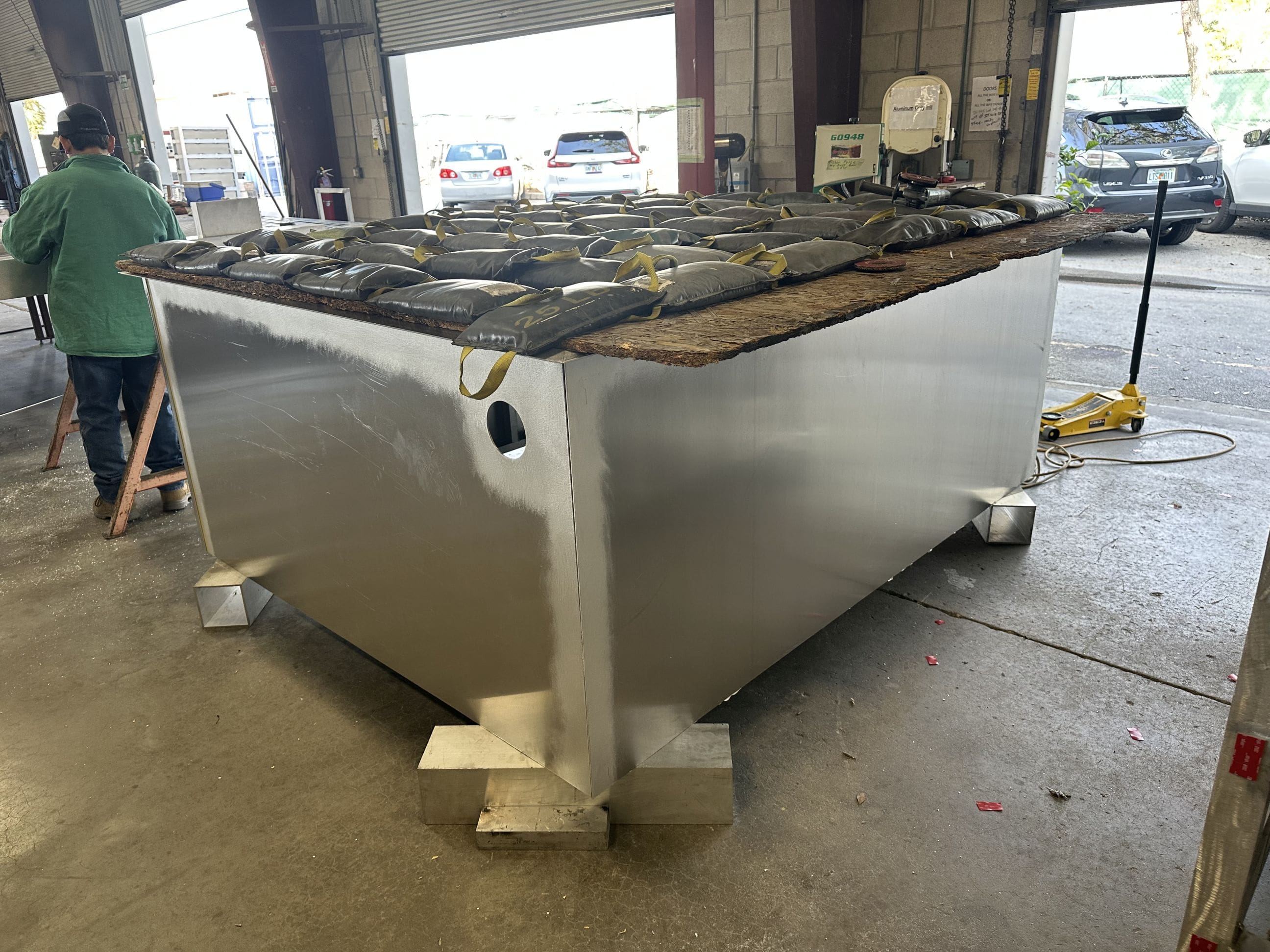

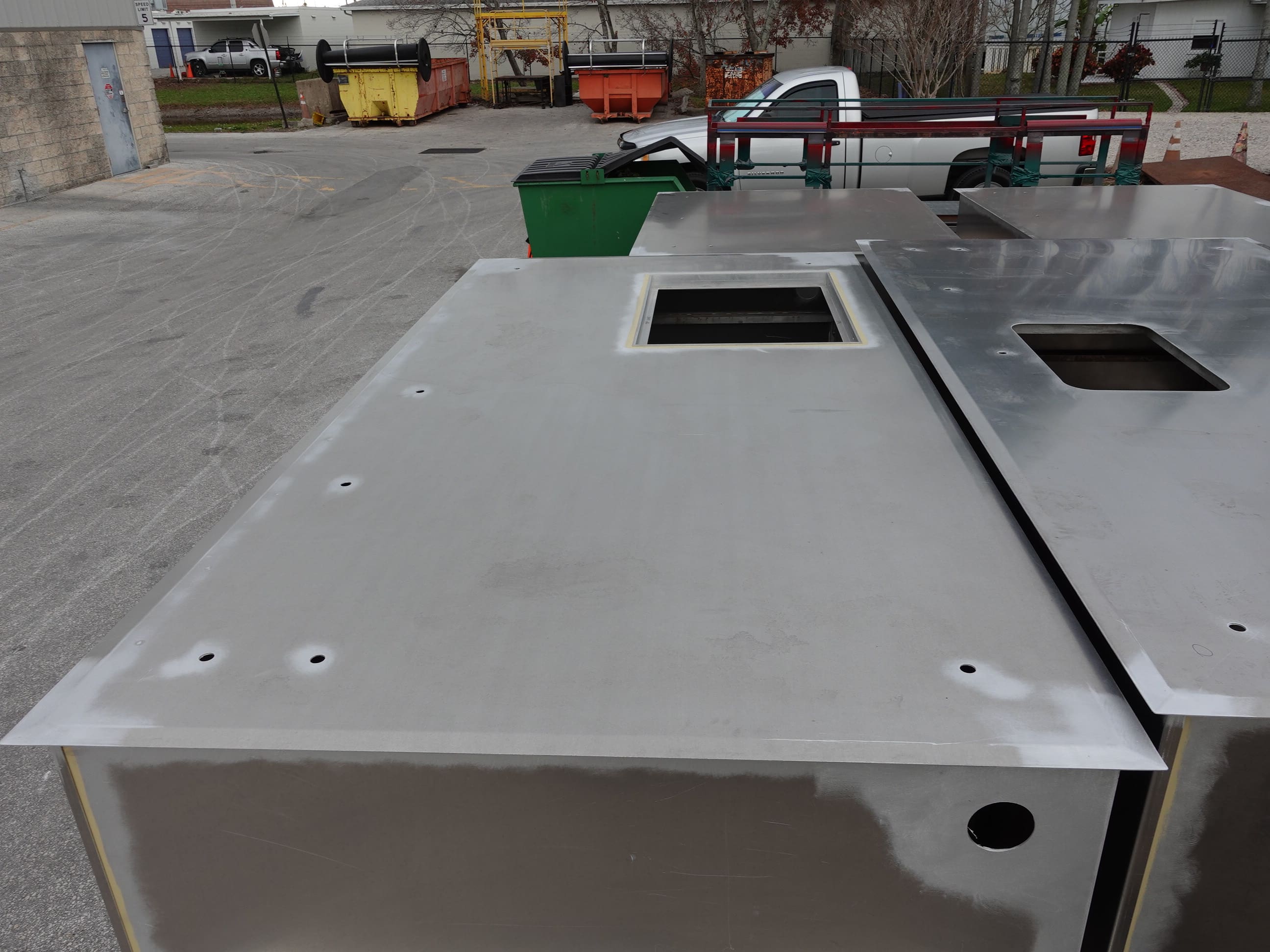

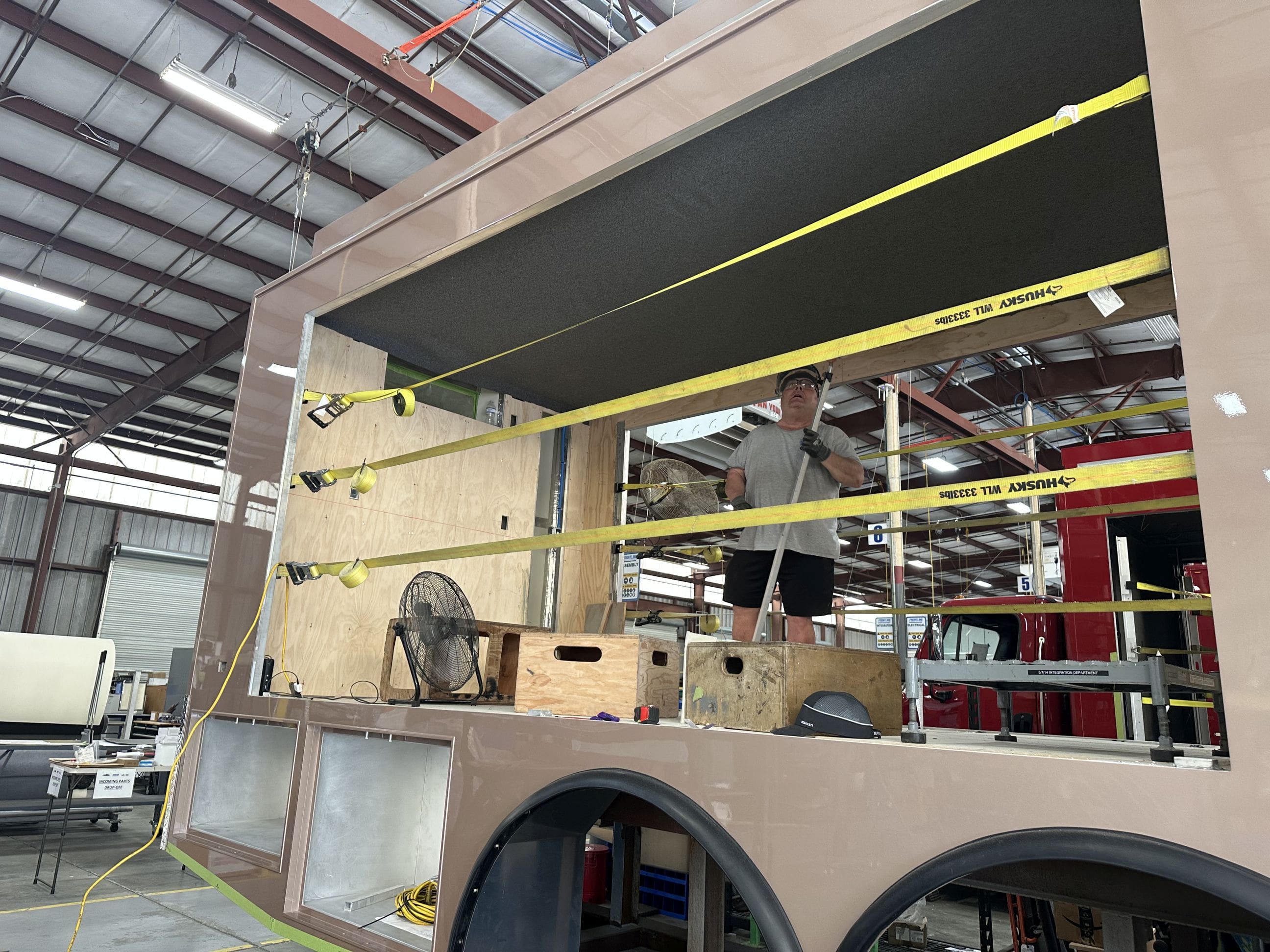

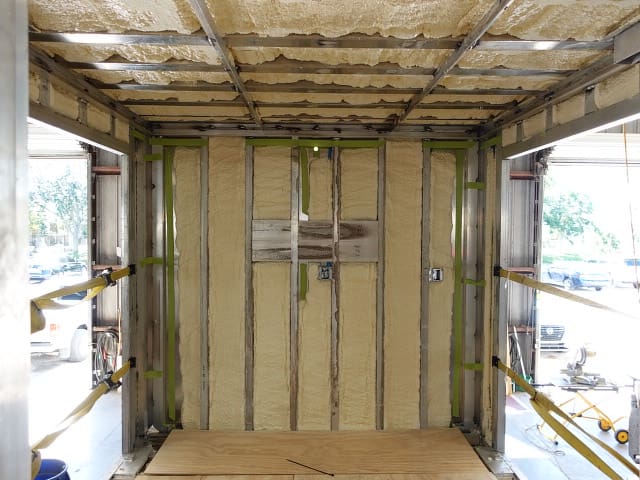

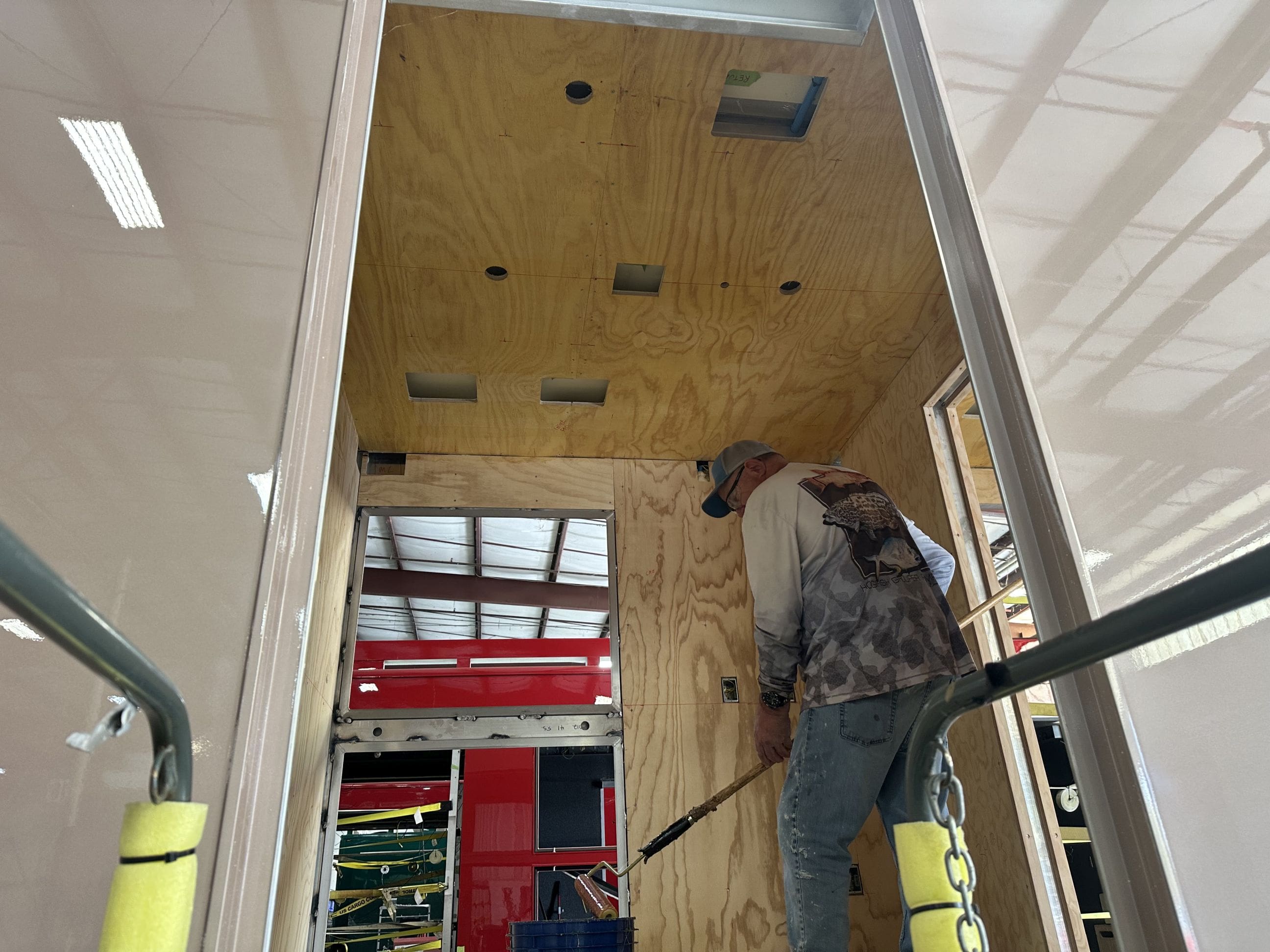

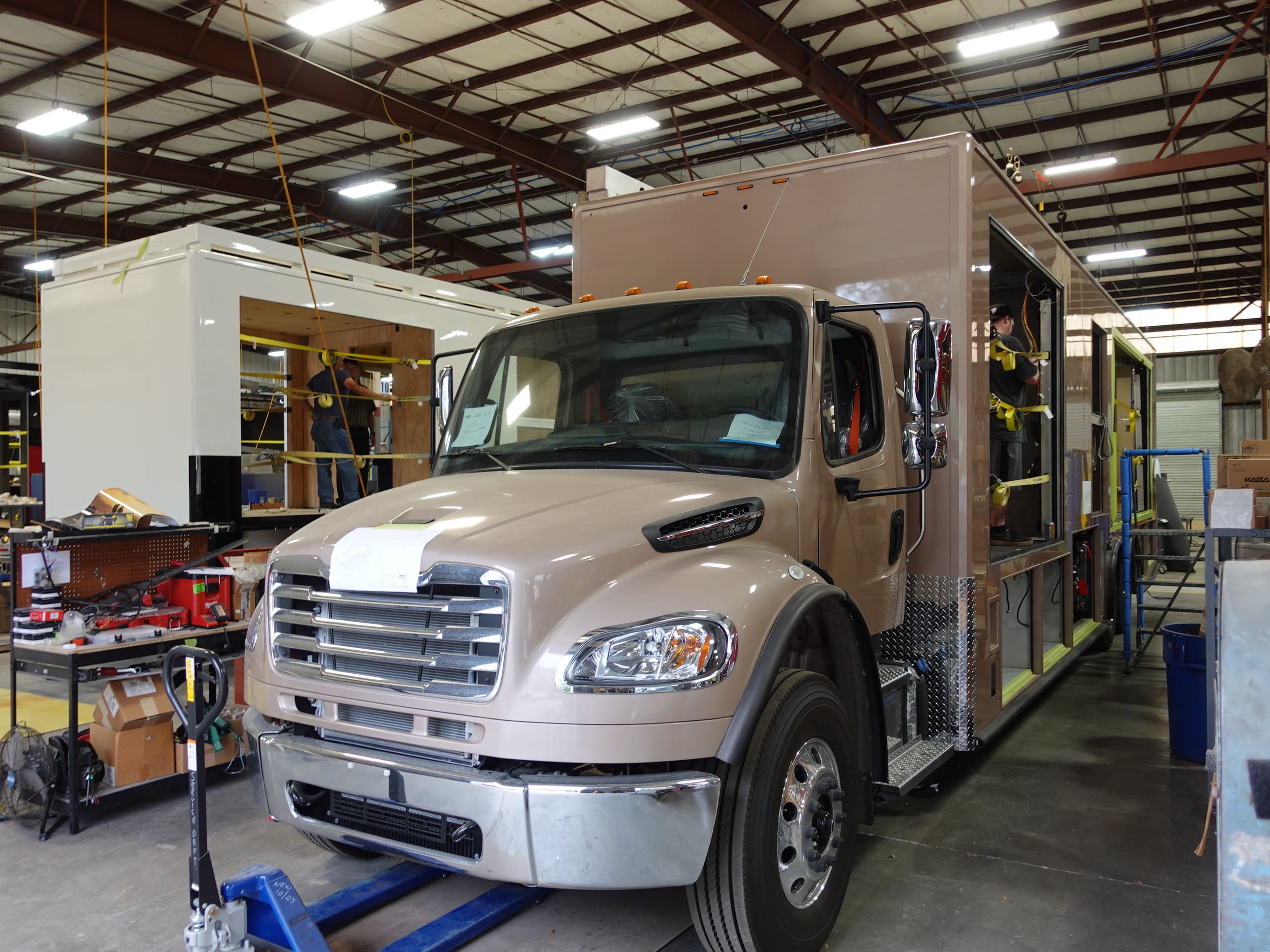

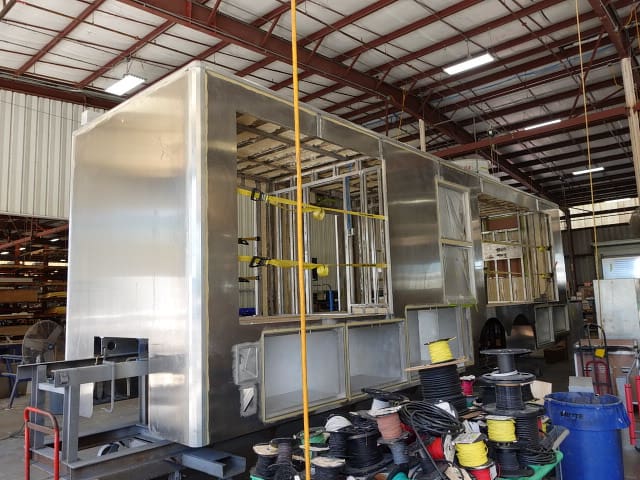

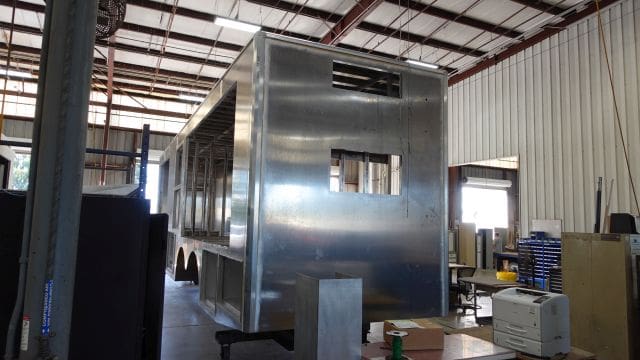

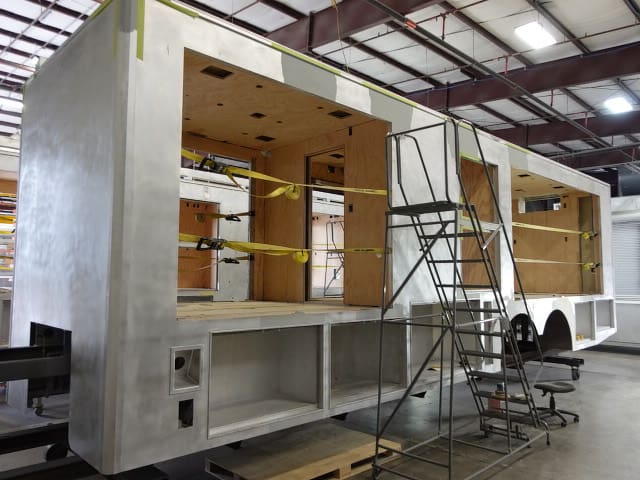

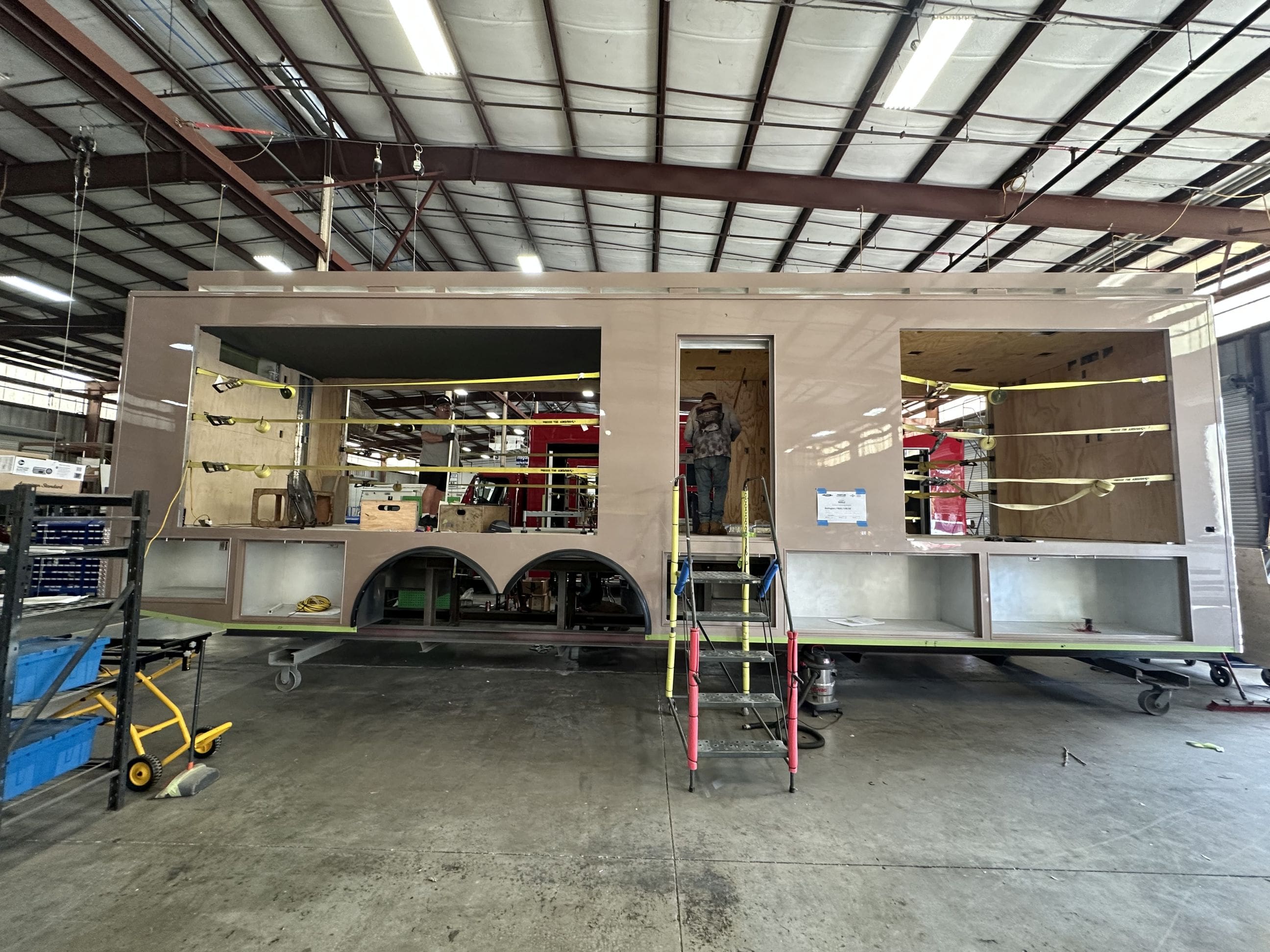

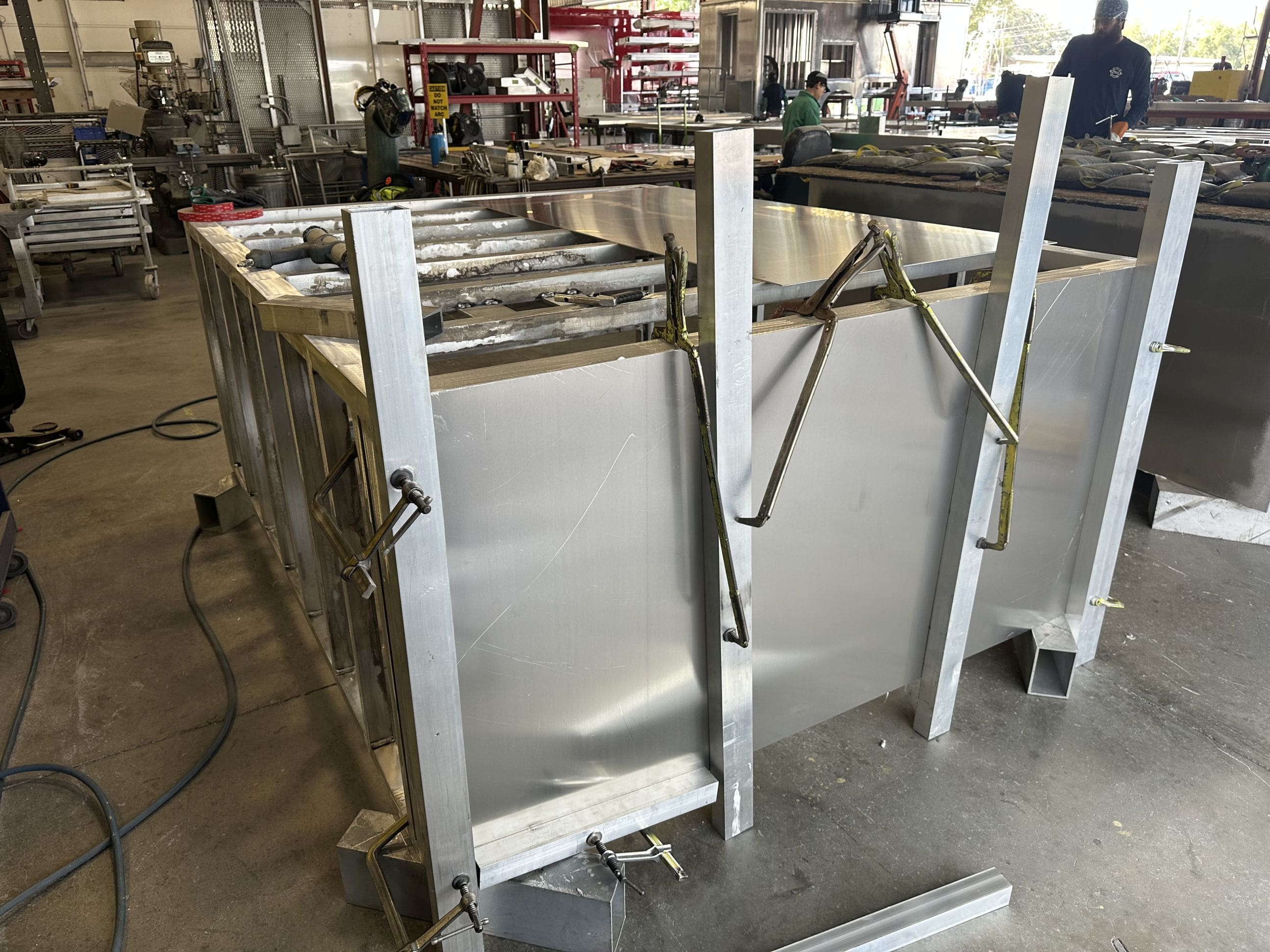

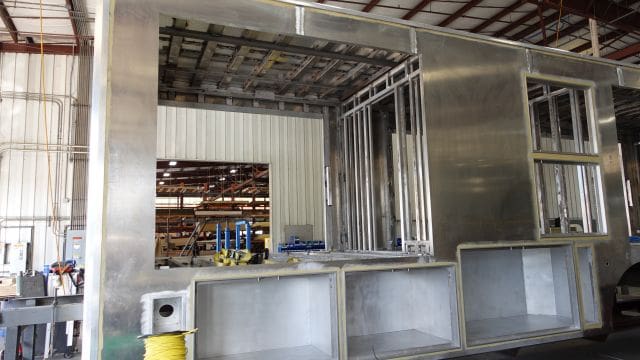

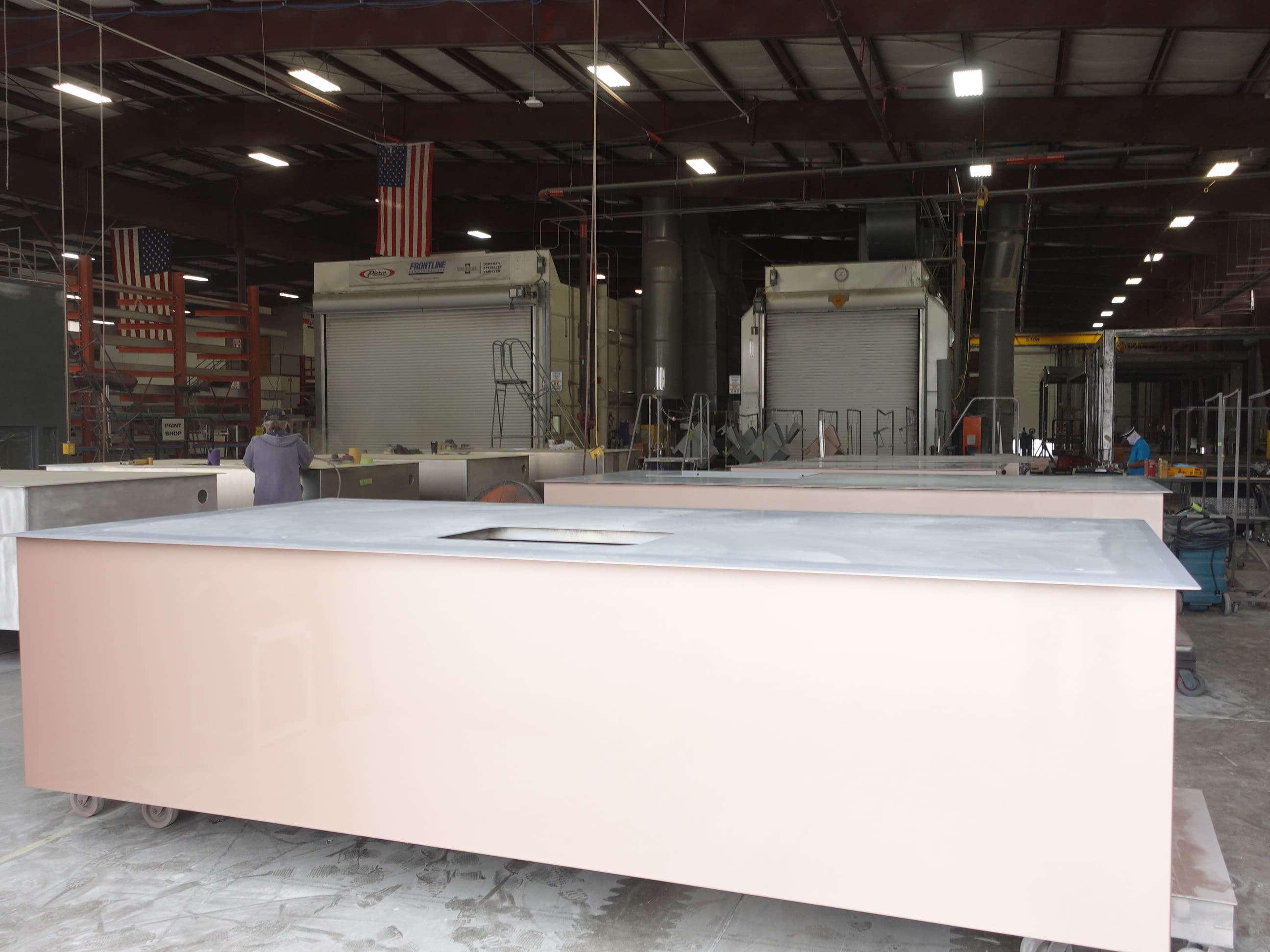

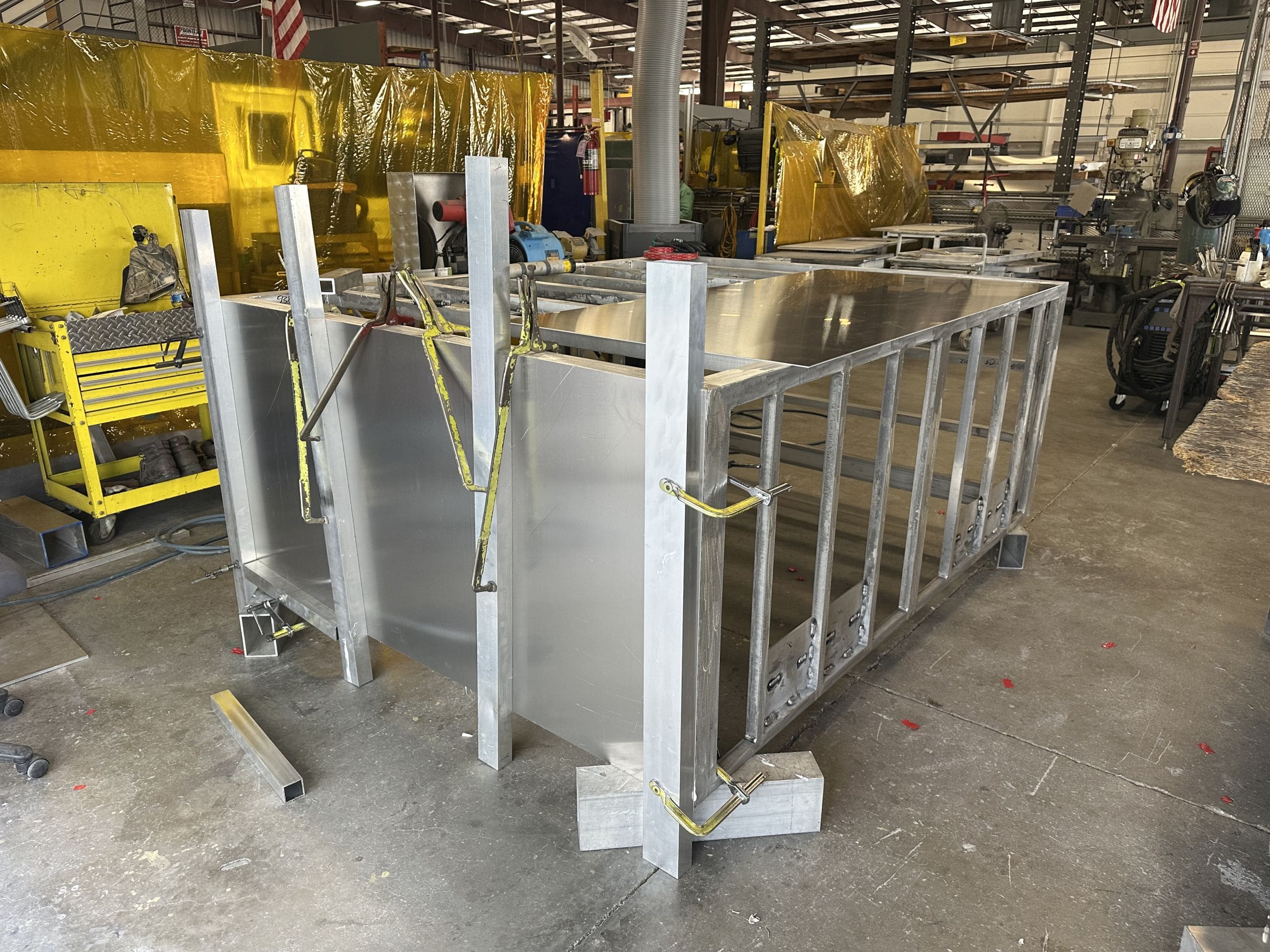

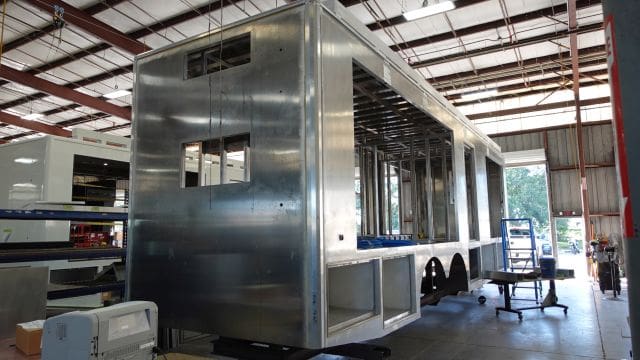

In this report, the chassis began preparations for fire and emergency use while the body completed fabrication and began the paint process.
11-07-25
In this report, the chassis remained staged (no photos) while the body continued fabrication.
10-17-25

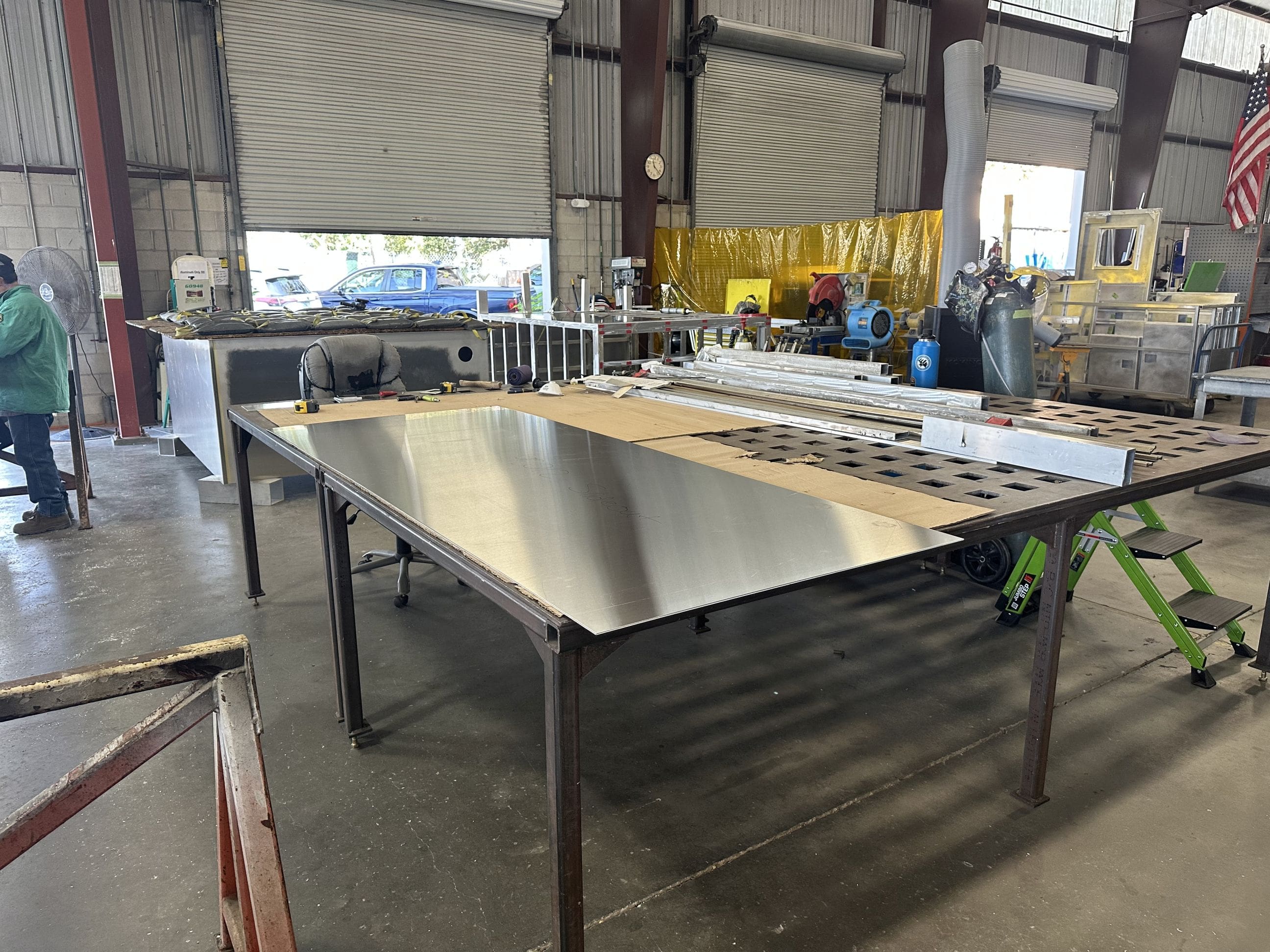

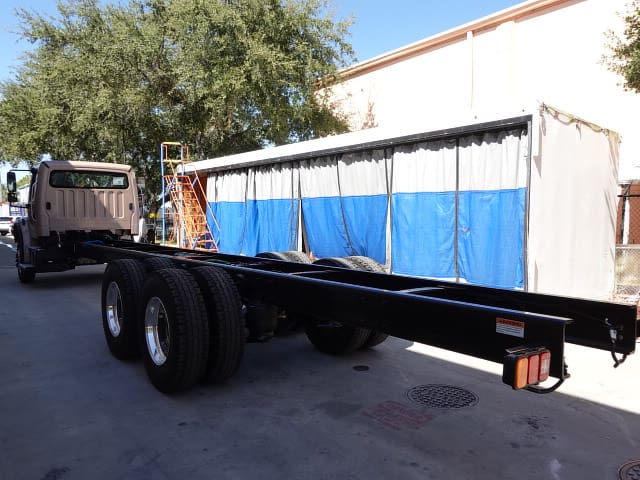

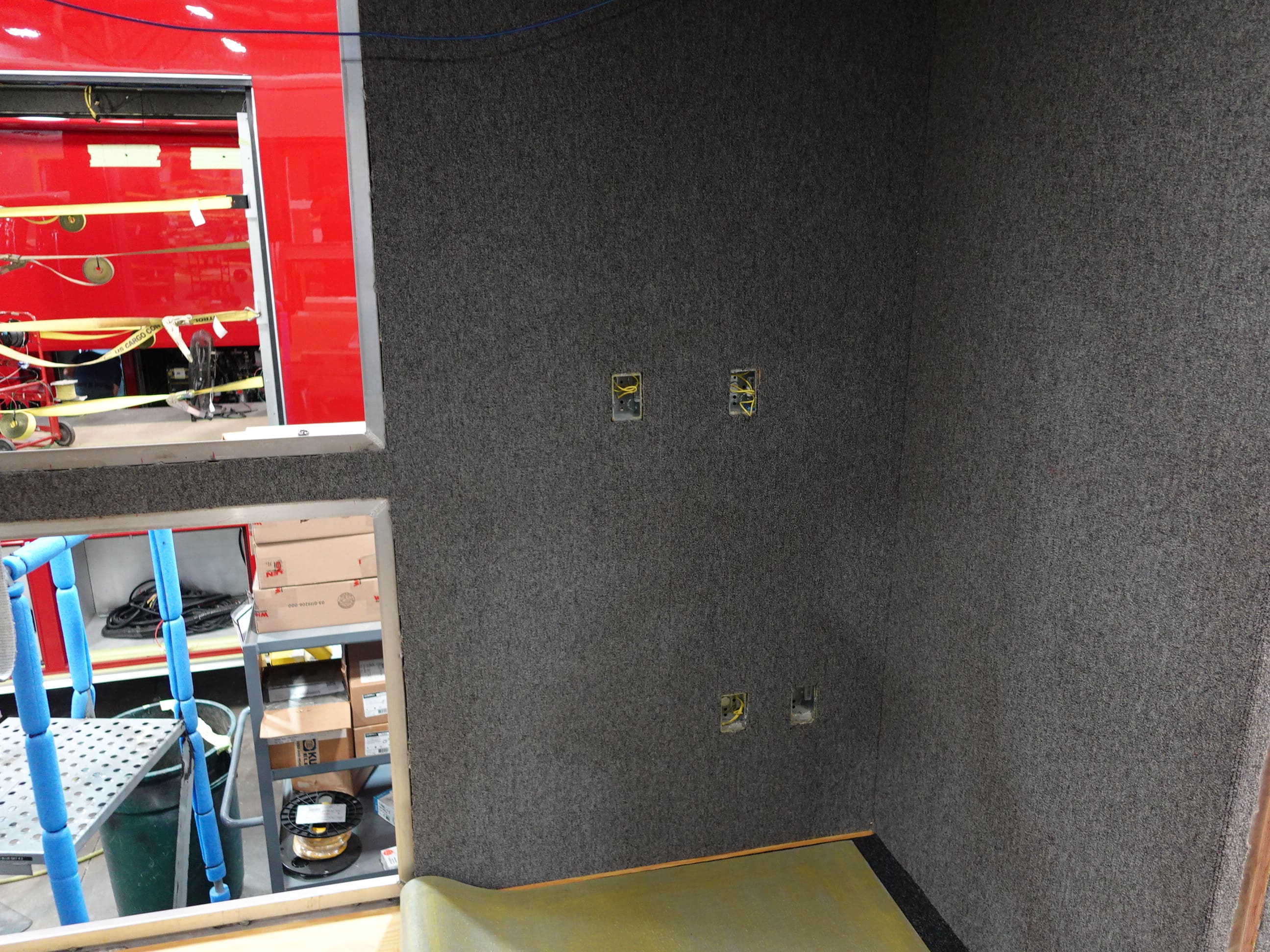

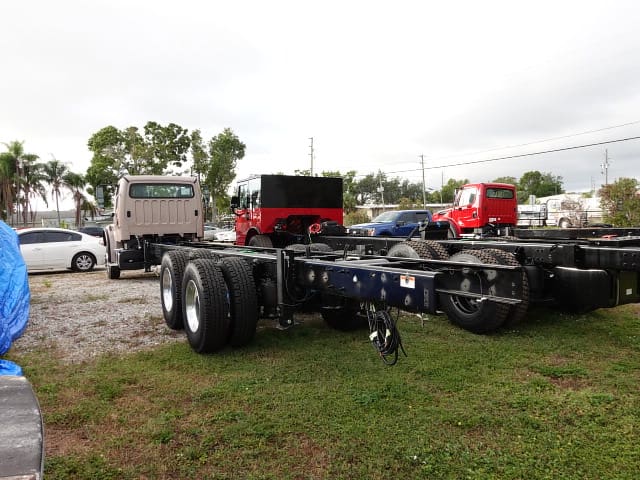

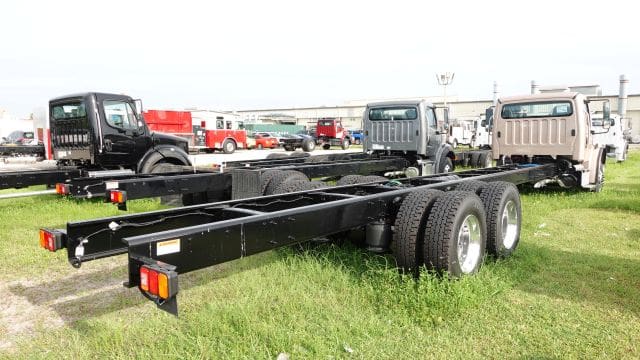

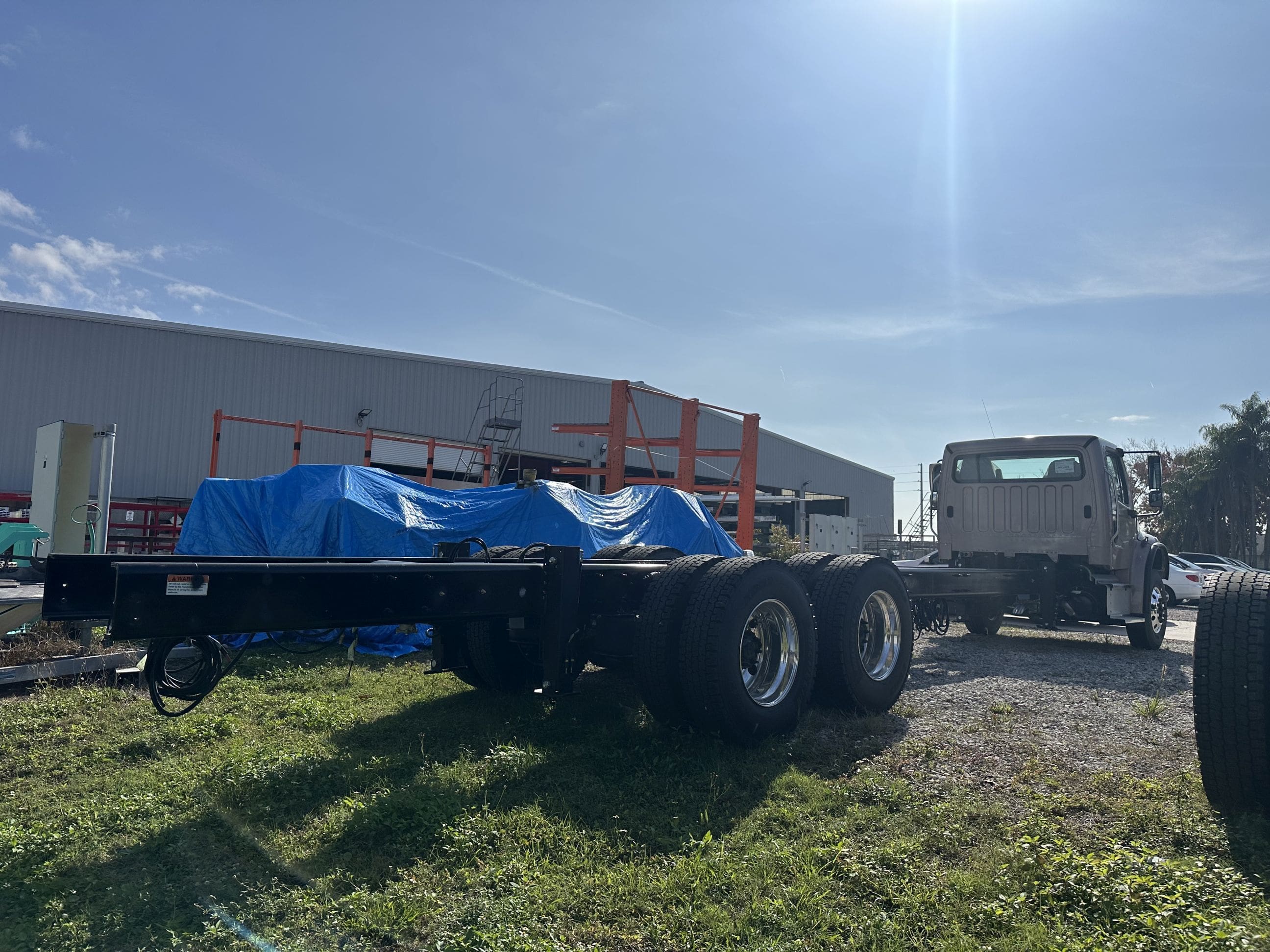

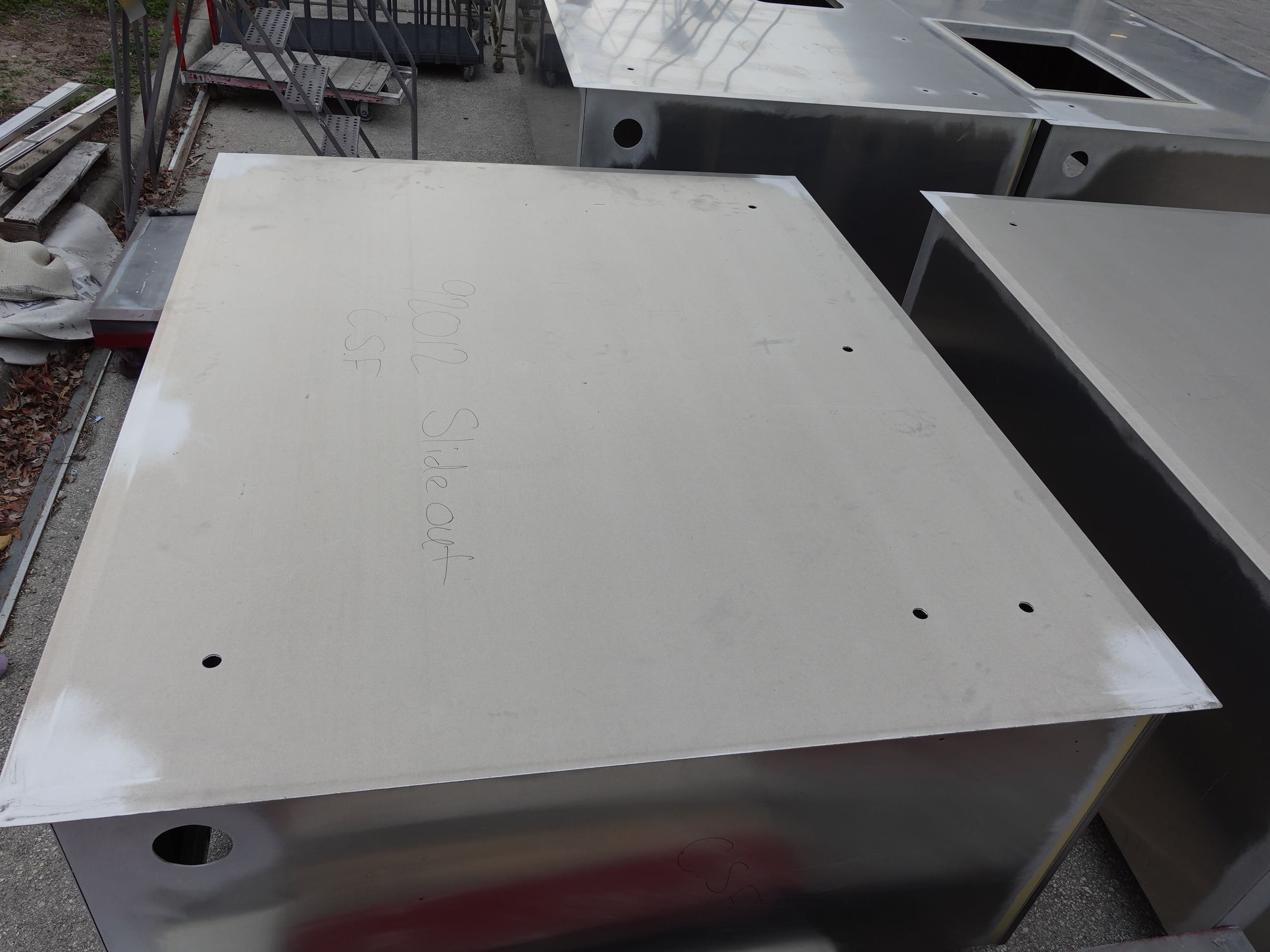

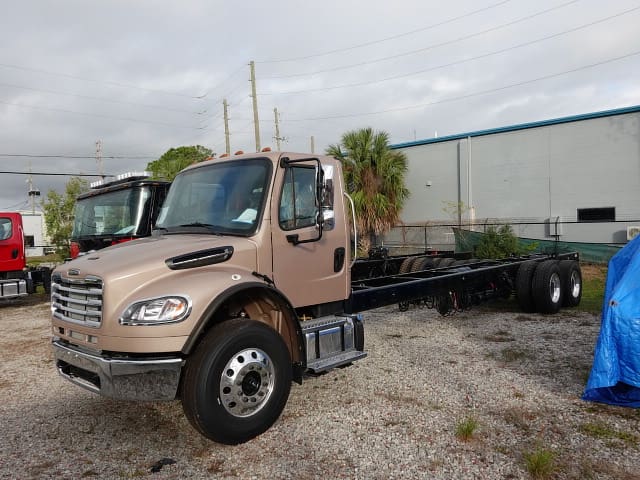

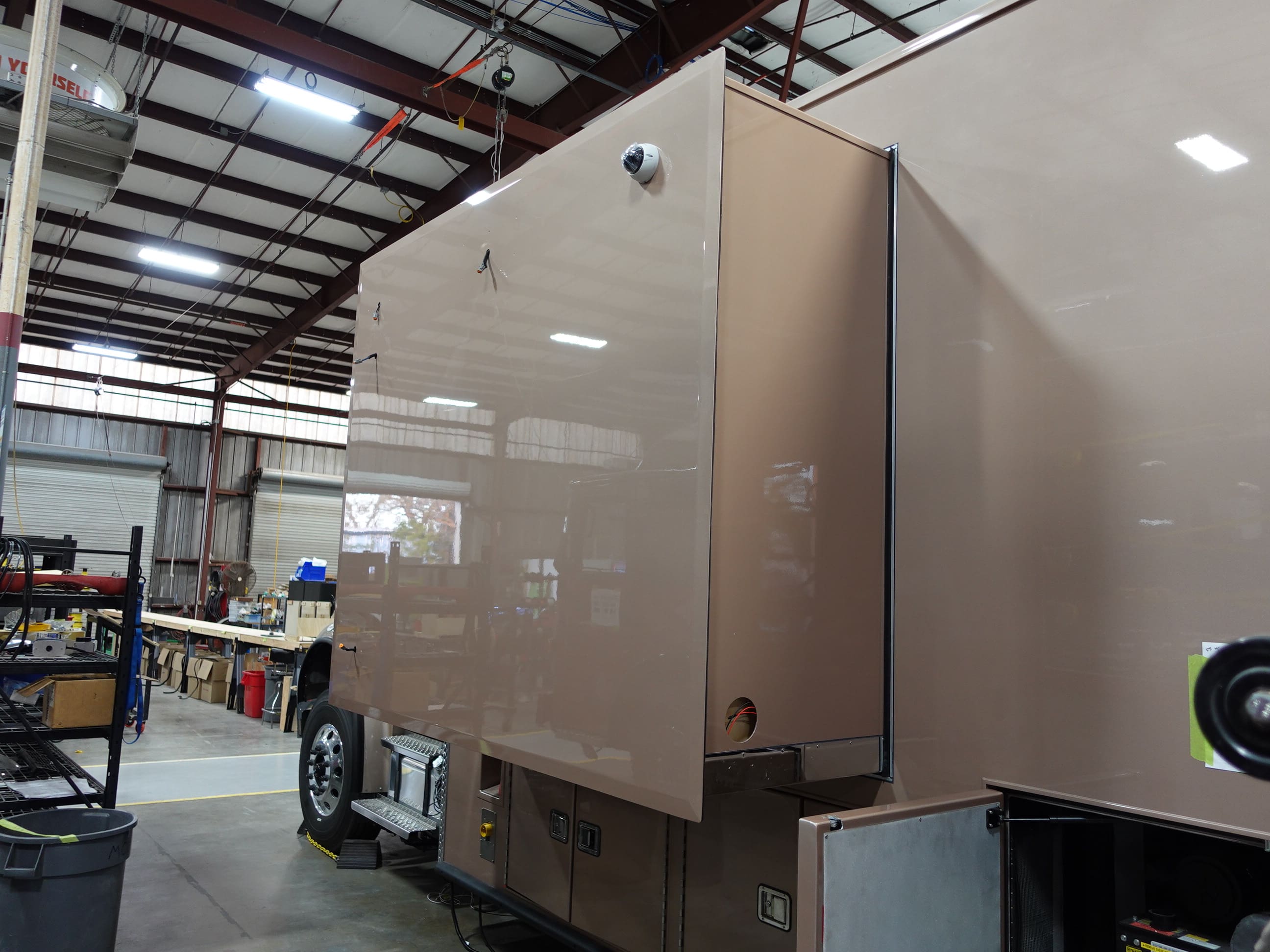

In this report, the chassis was transferred to the Frontline facility, the body continued fabrication, and the materials for the slide outs was cut.
10-03-25

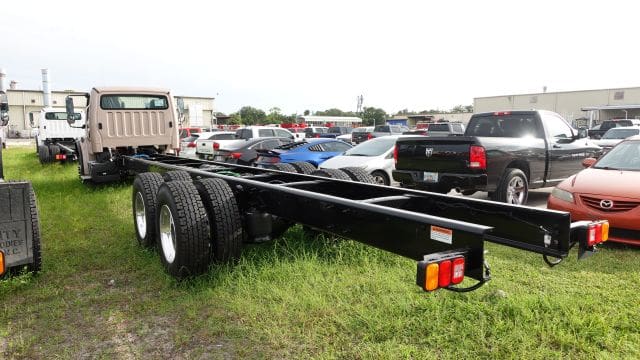

In this report, the chassis remained staged (no photos), while the body continued fabrication.
09-19-25

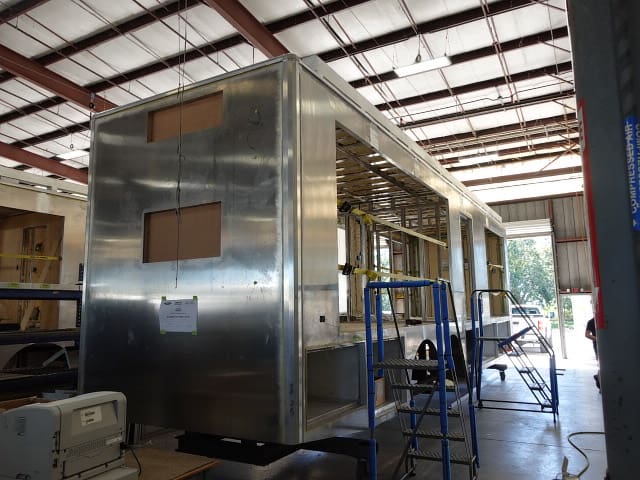

This unit is now in production!

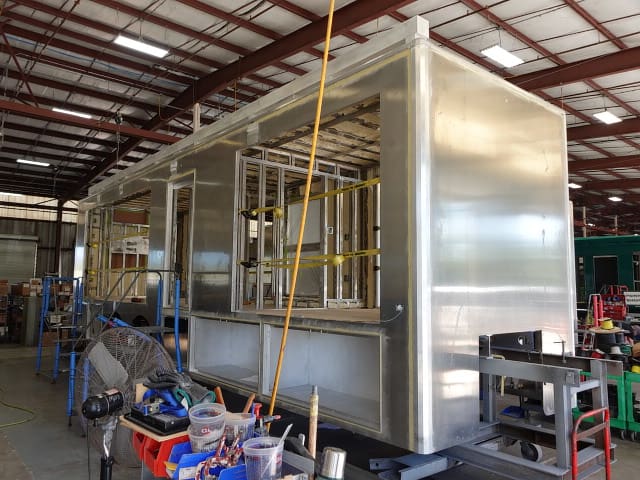

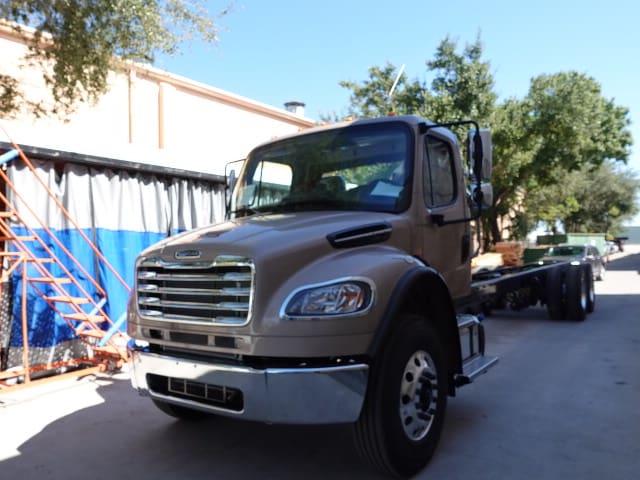

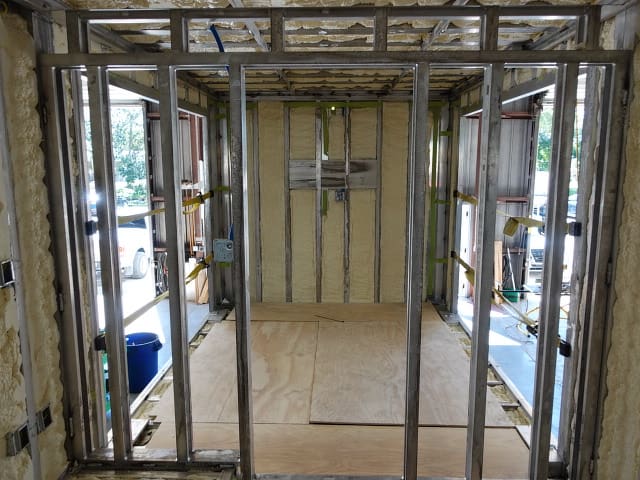

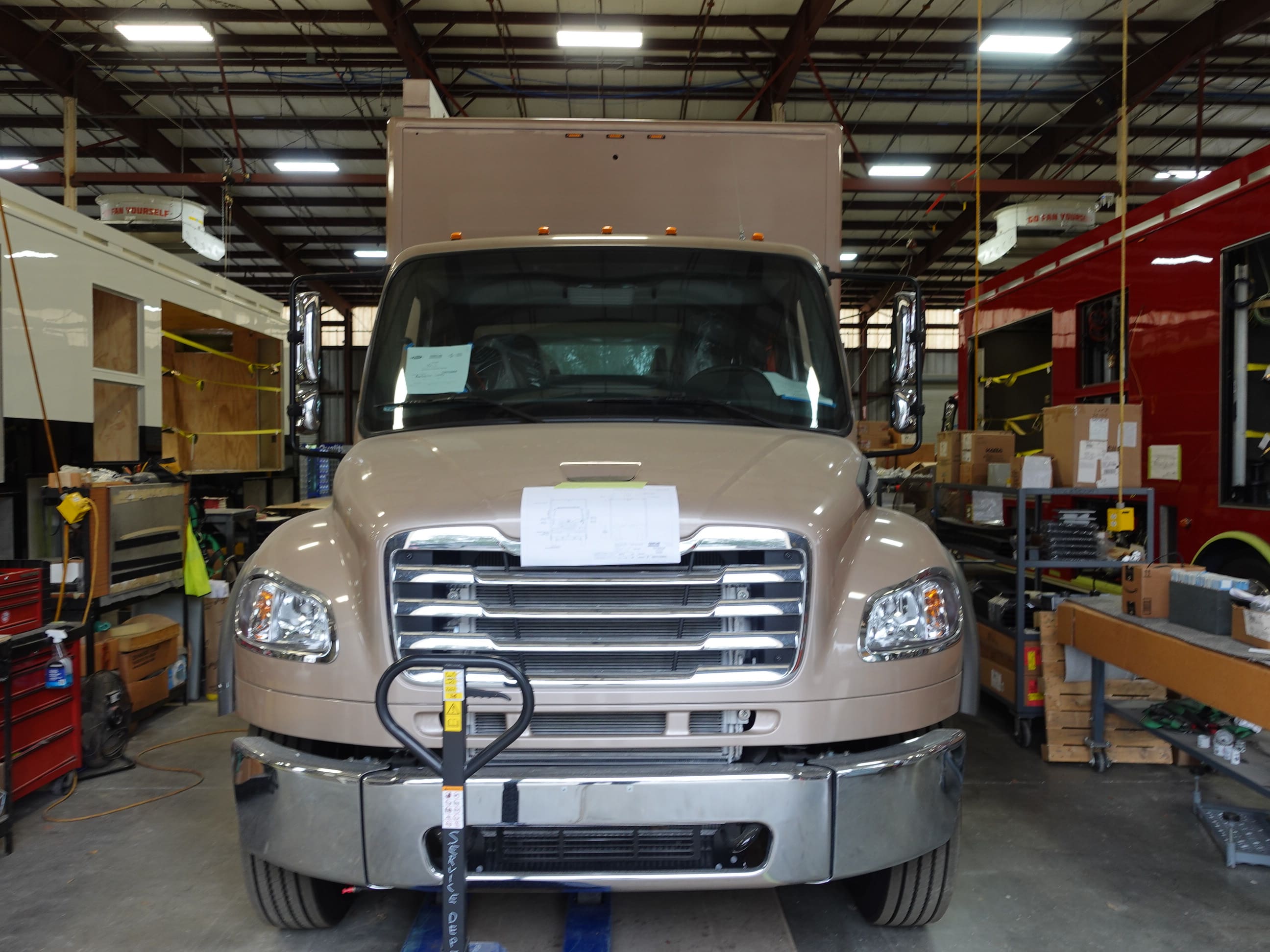

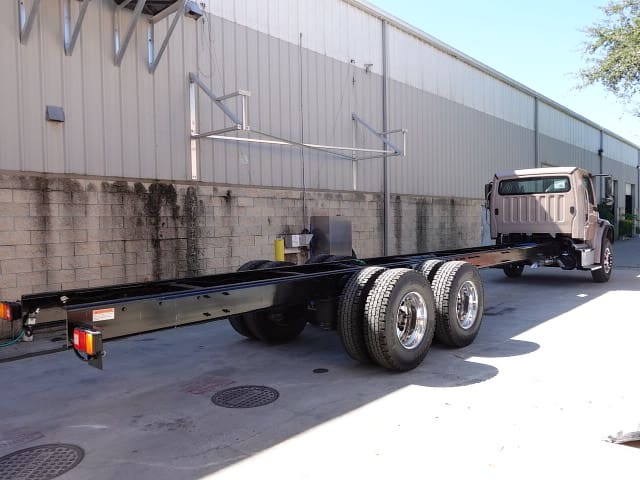

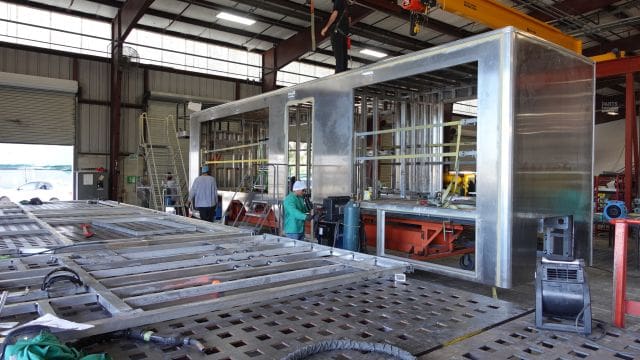

In this report, the chassis arrived and was staged to begin preparation for fire and emergency use while the body began fabrication.
