12-05-25

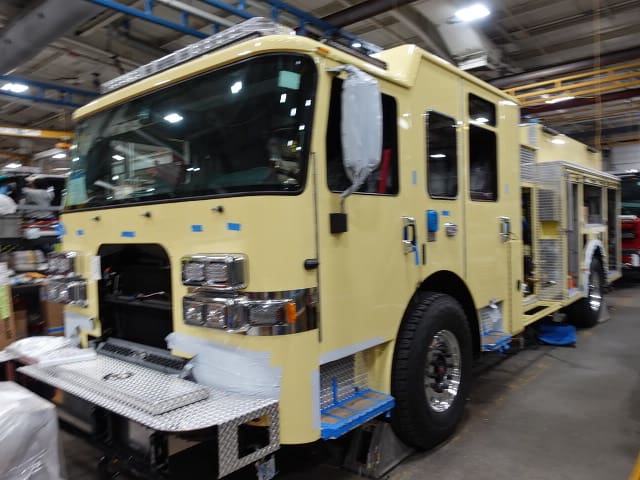

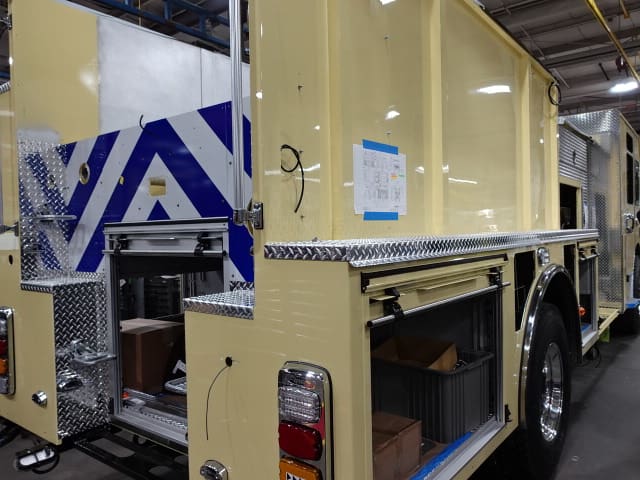

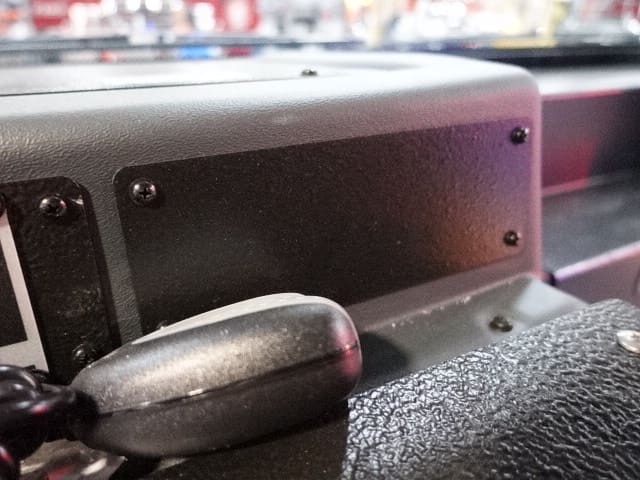

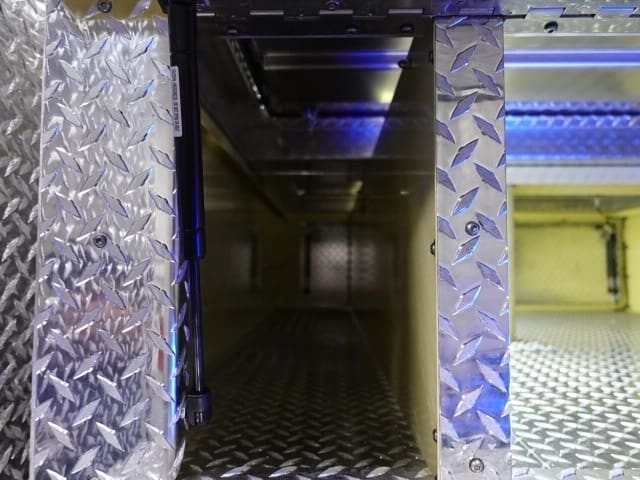

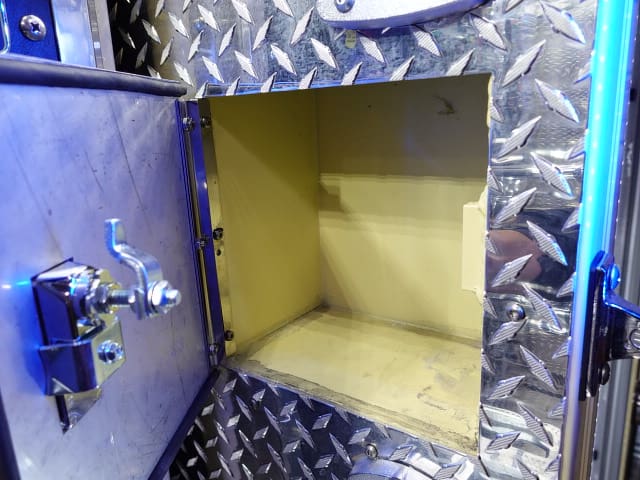

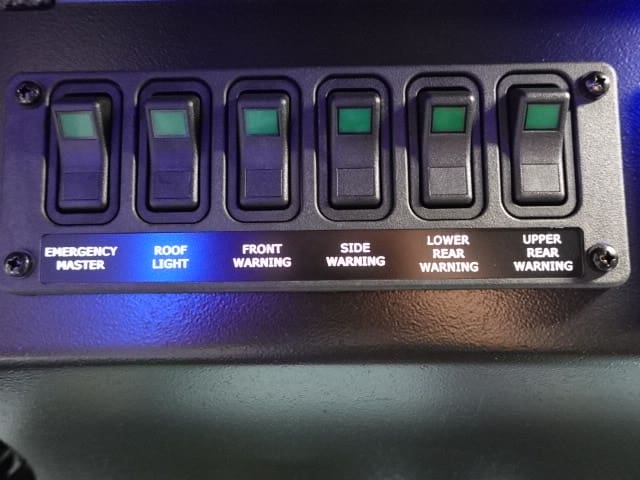

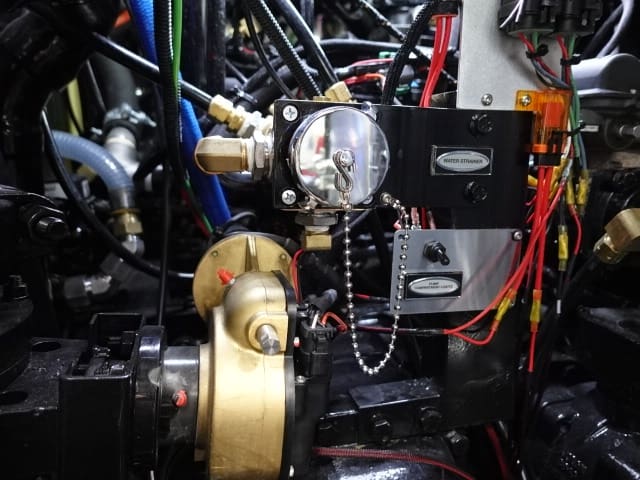

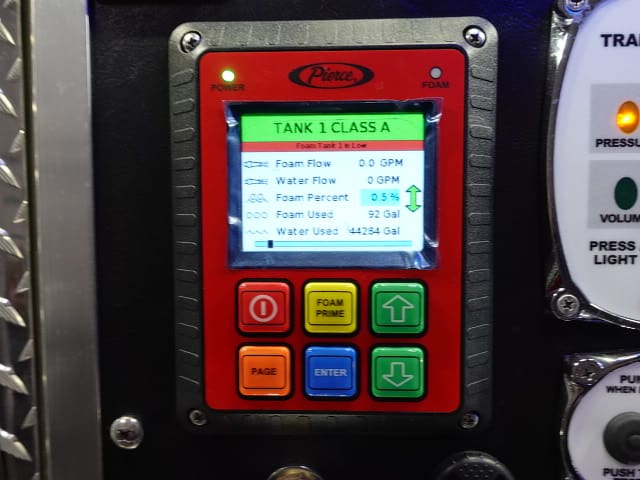

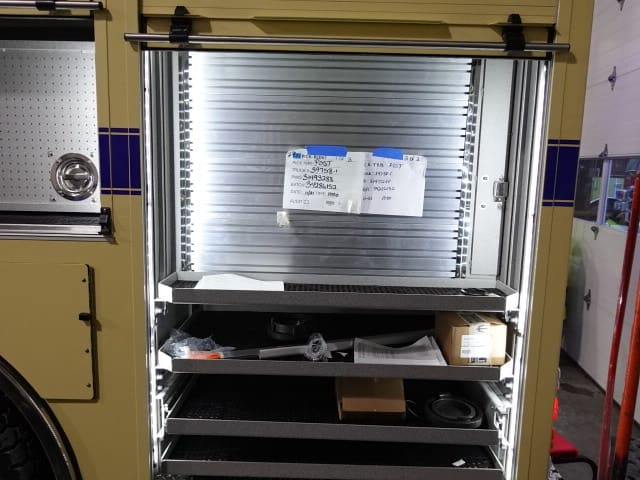

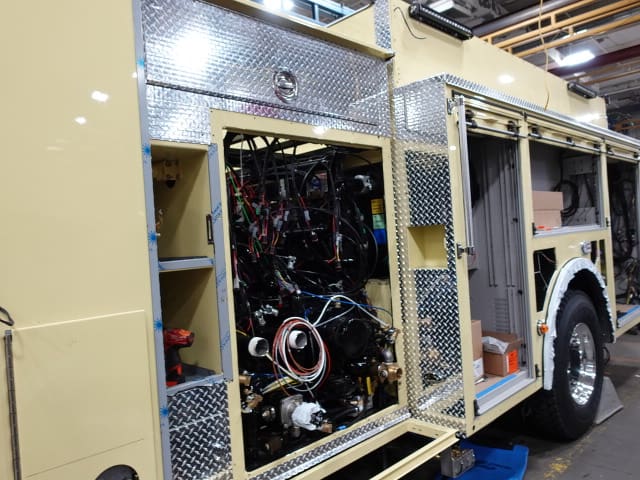

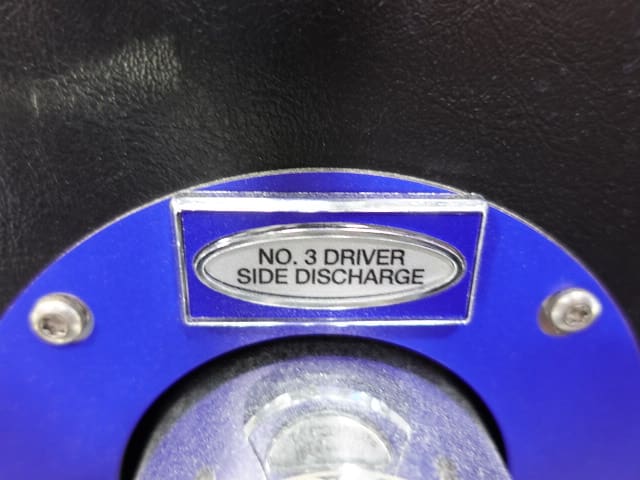

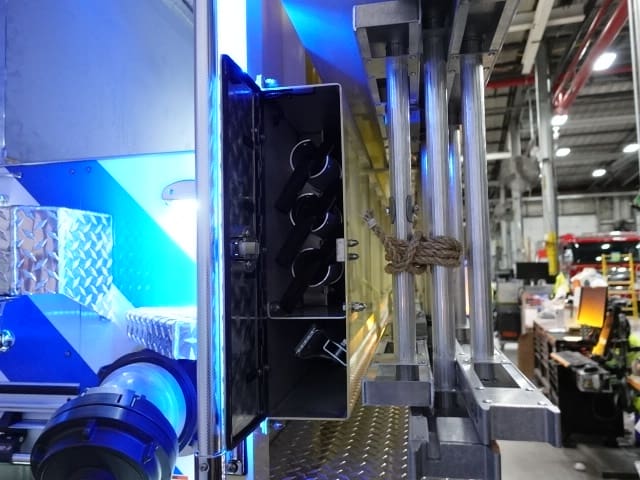

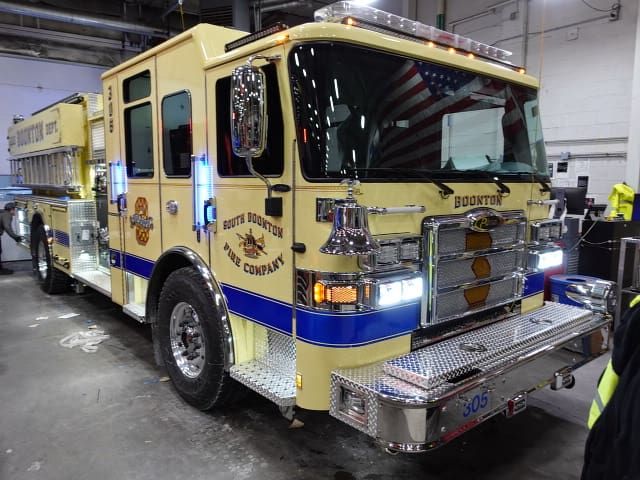

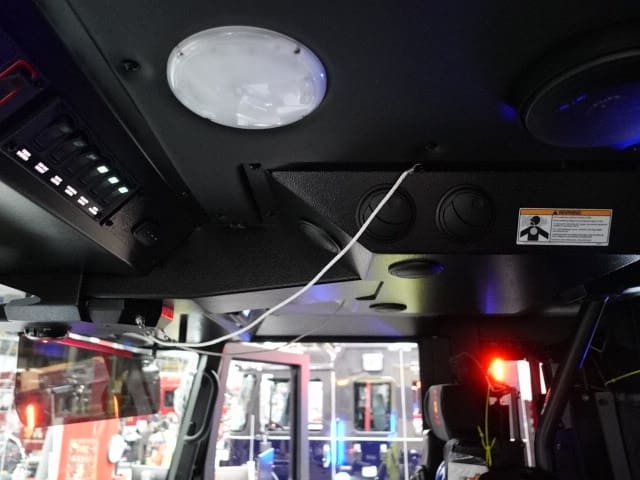

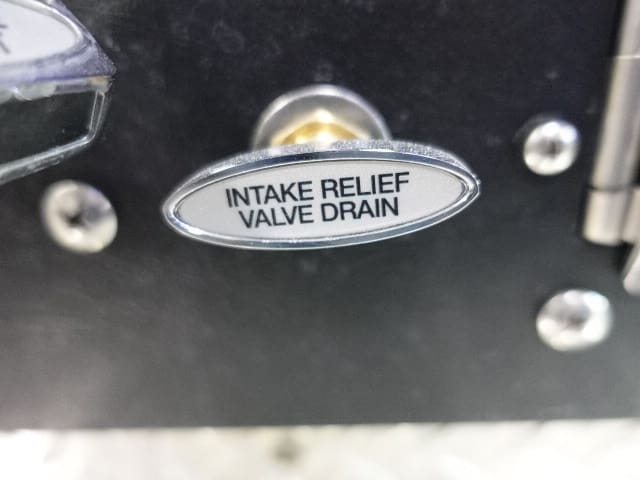

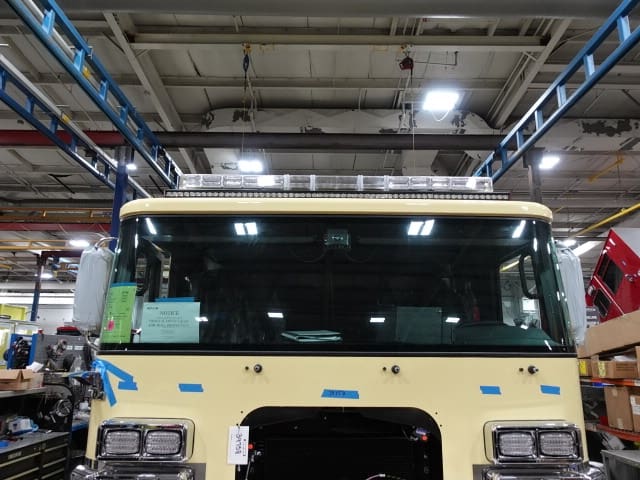

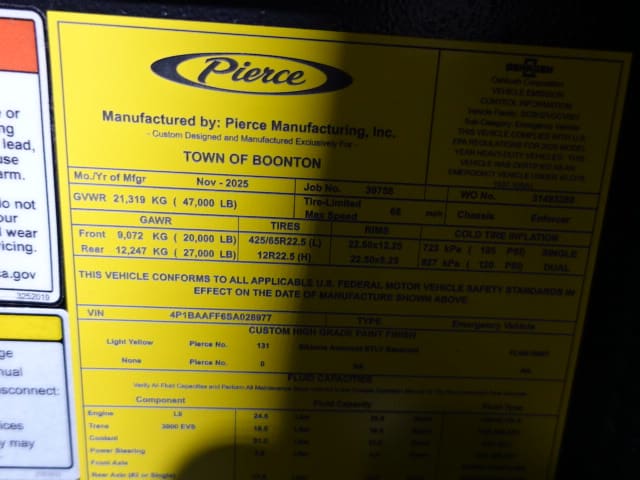

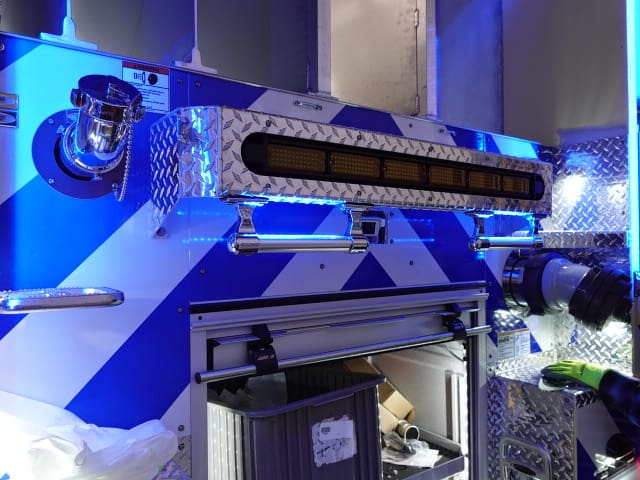

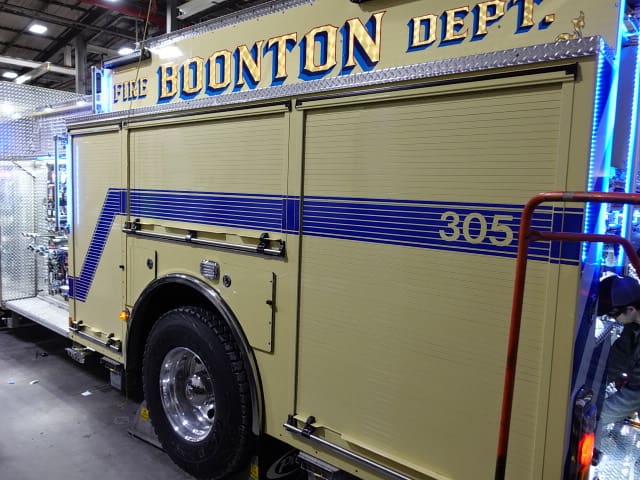

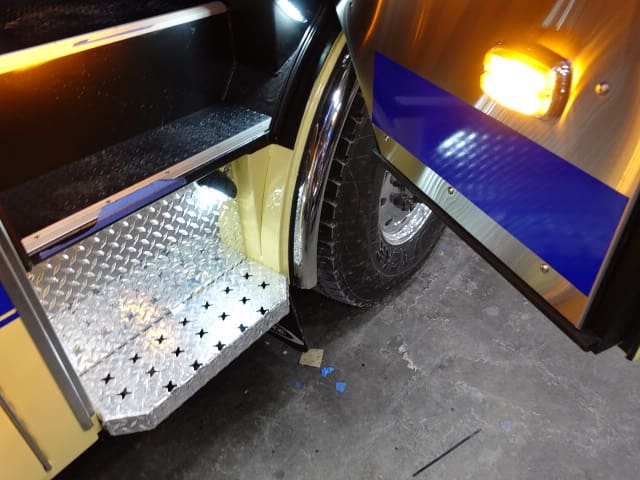

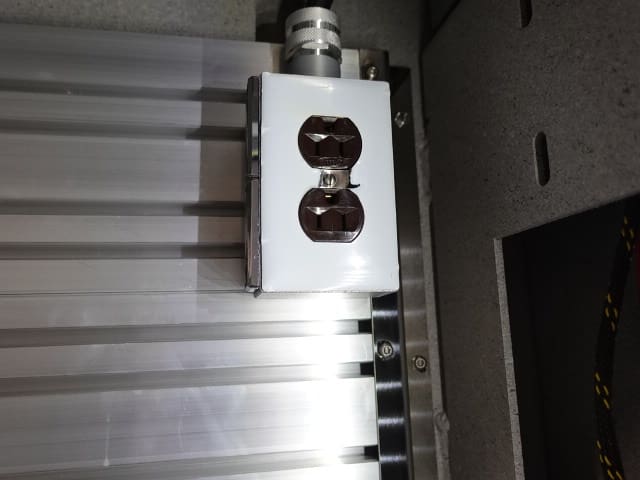

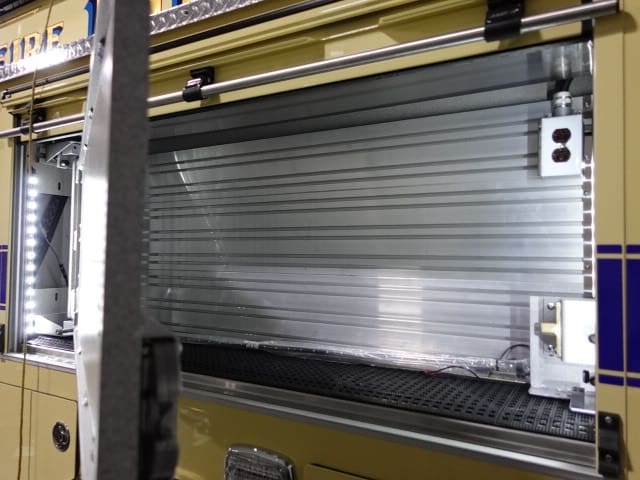

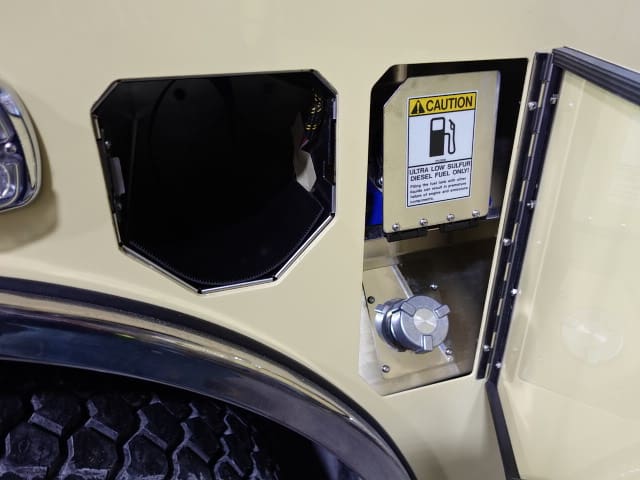

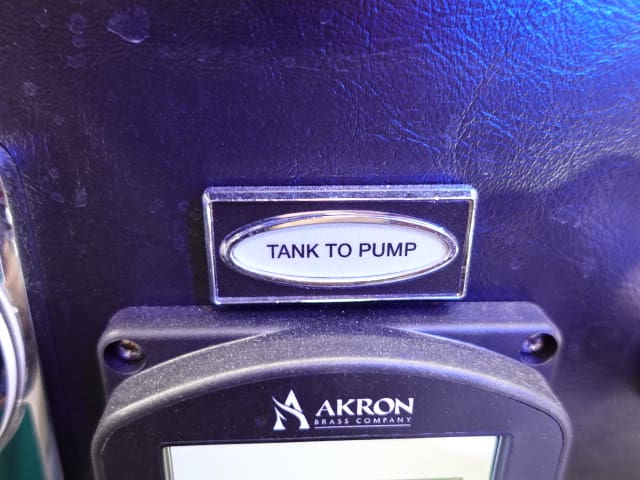

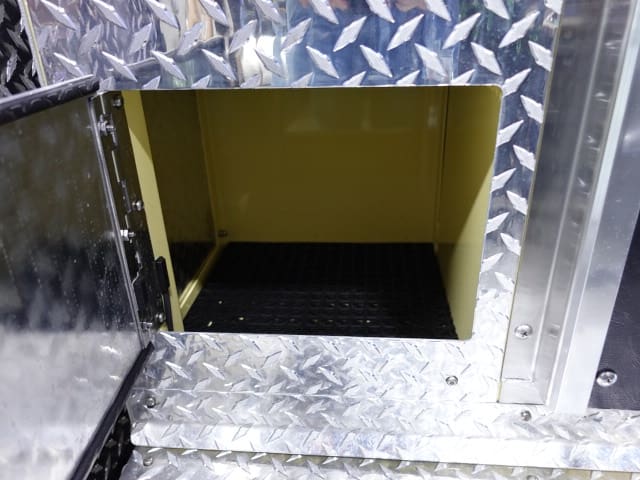

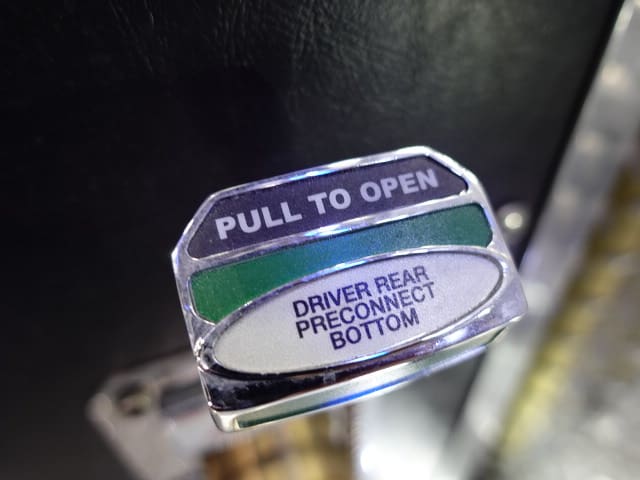

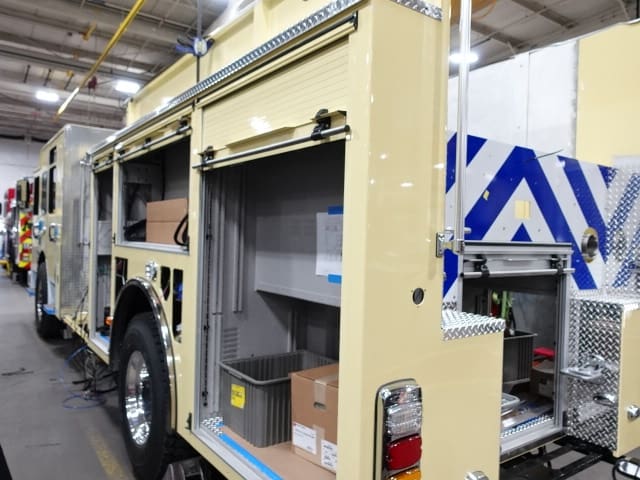

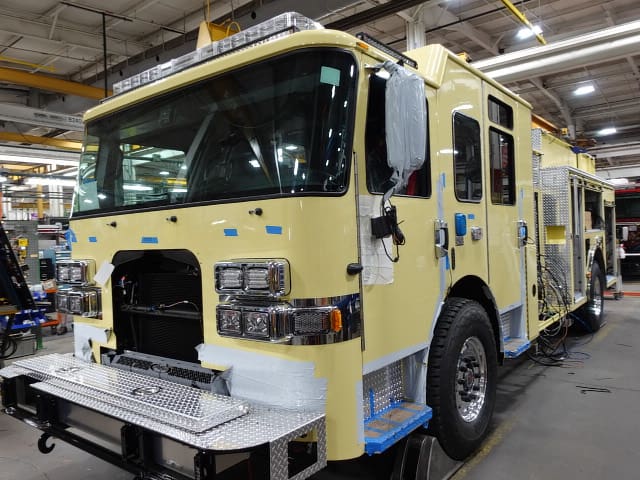

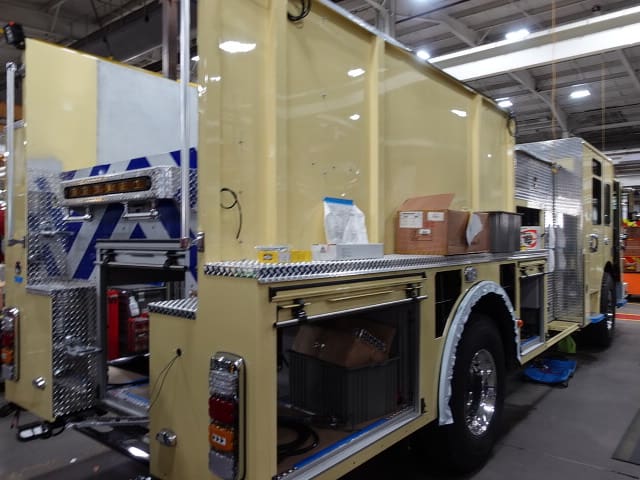

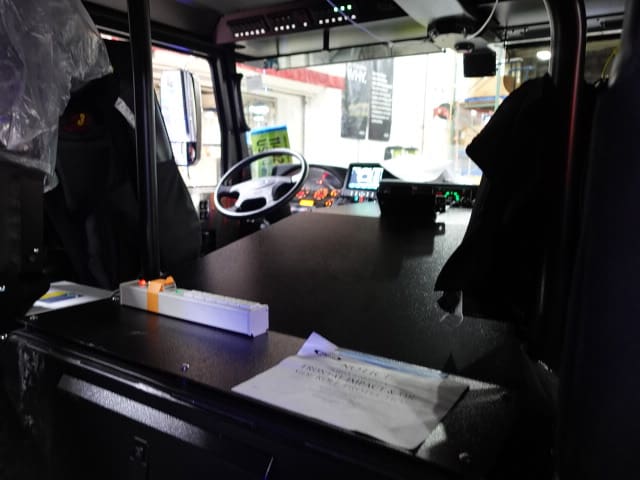

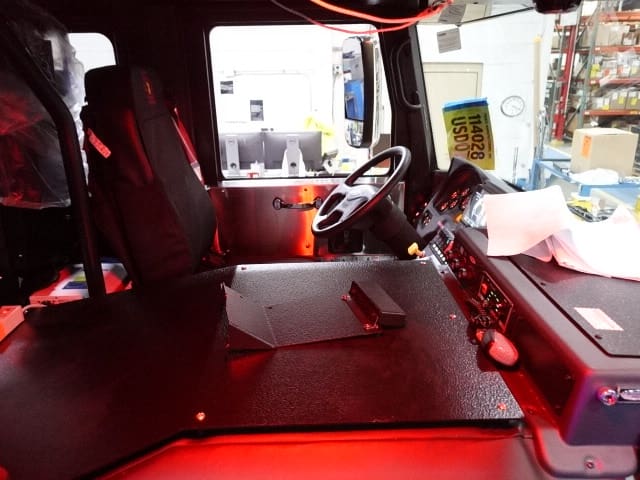

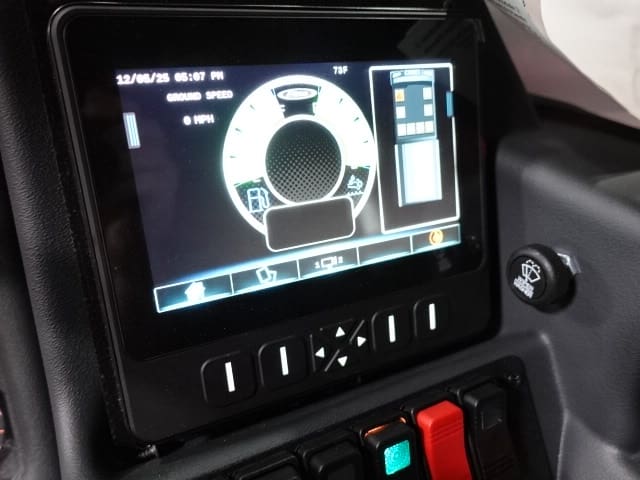

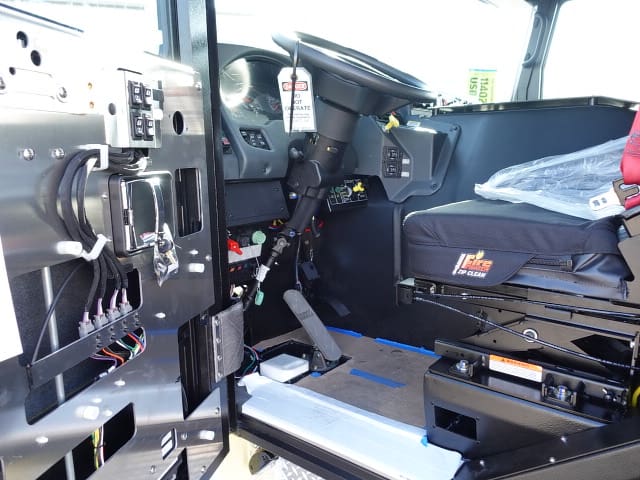

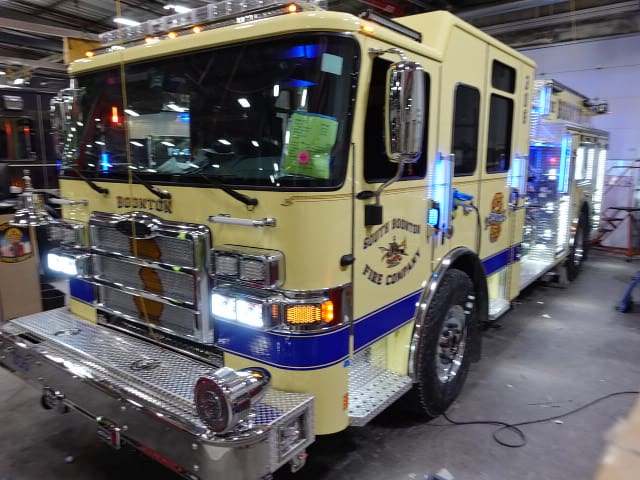

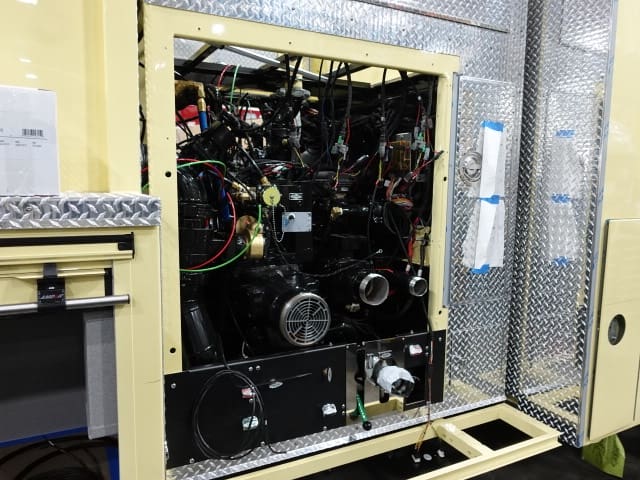

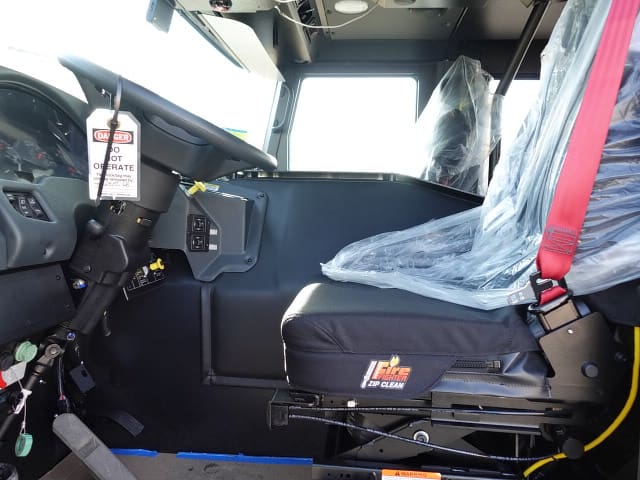

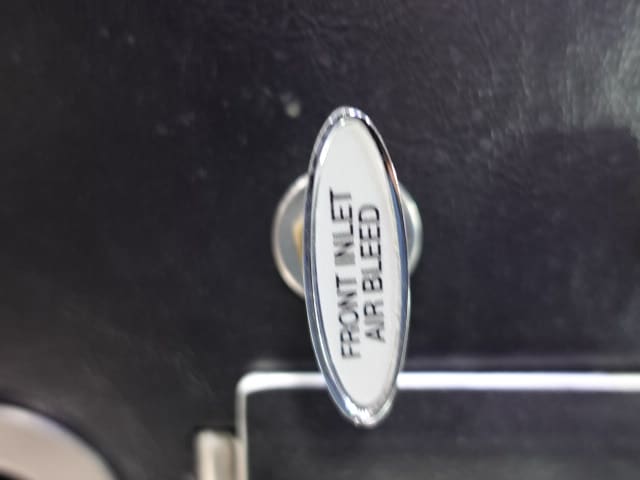

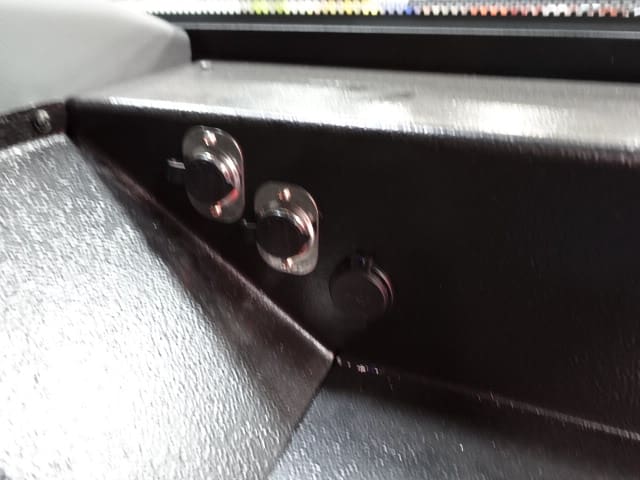

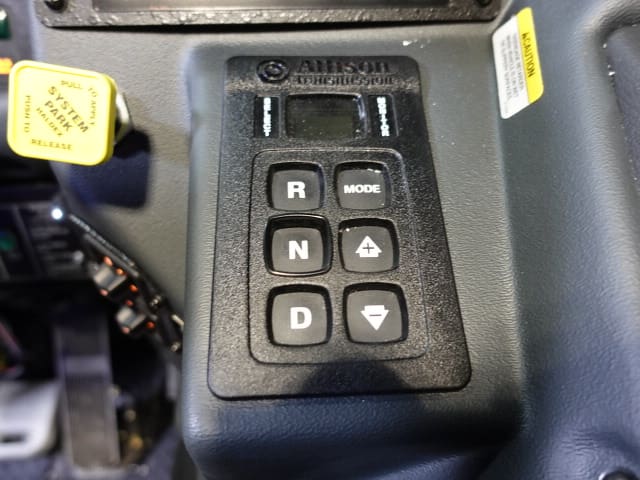

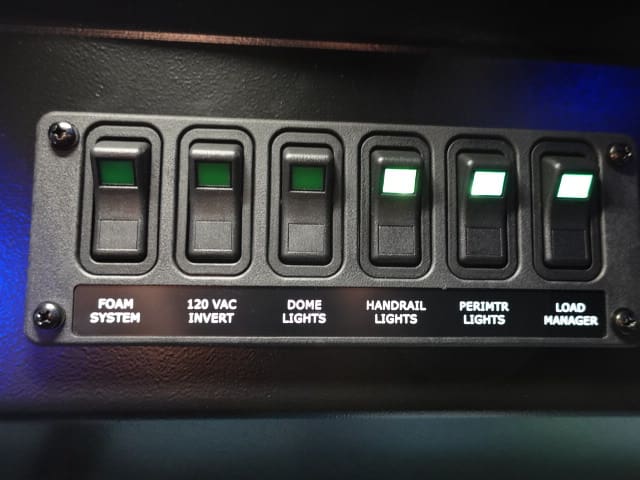

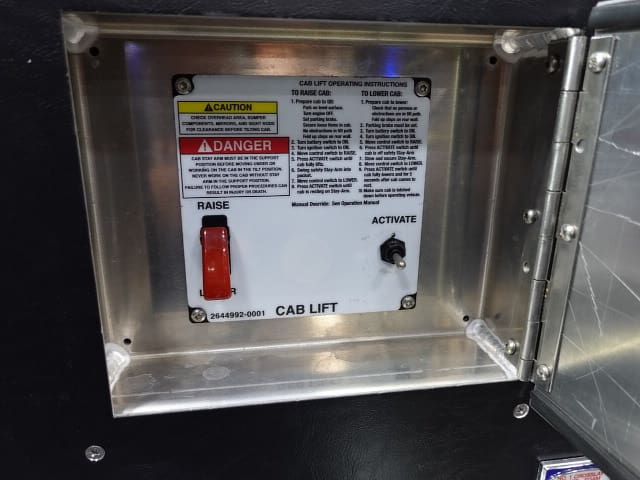

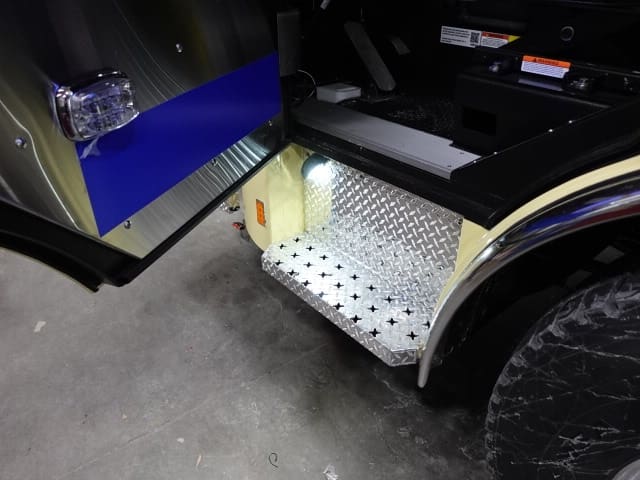

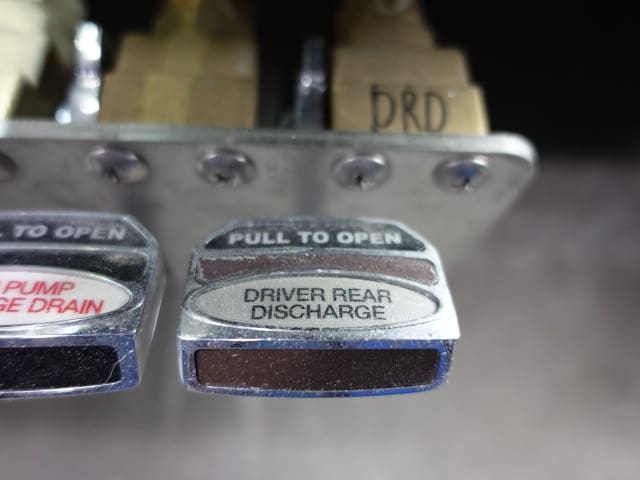

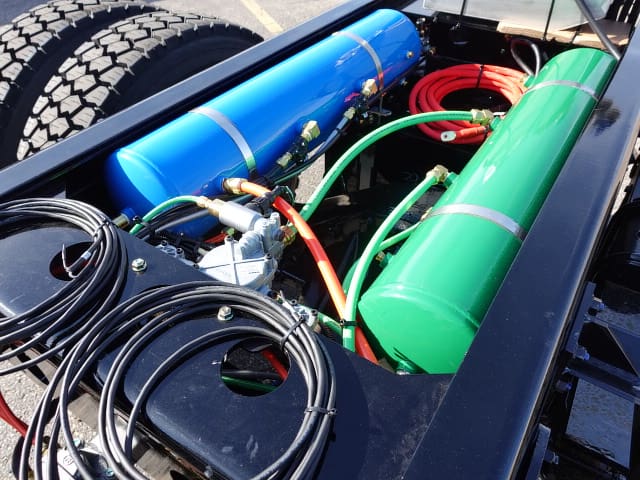

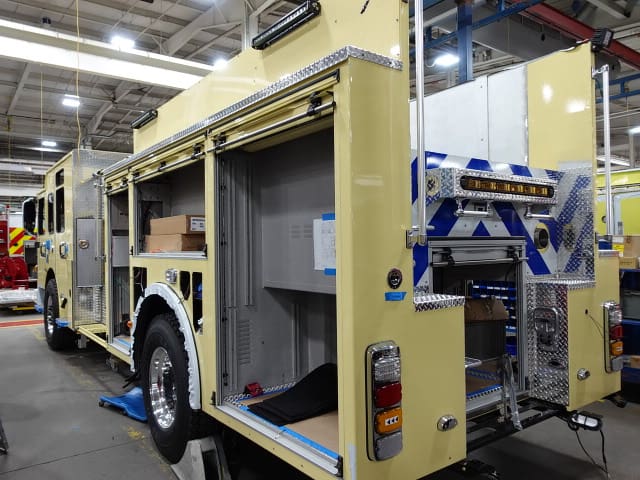

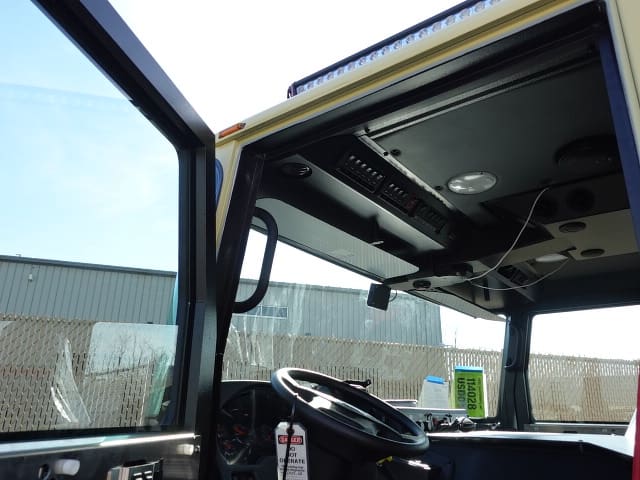

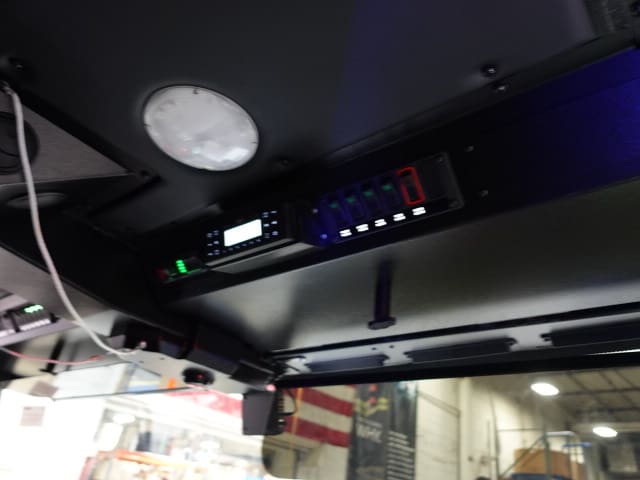

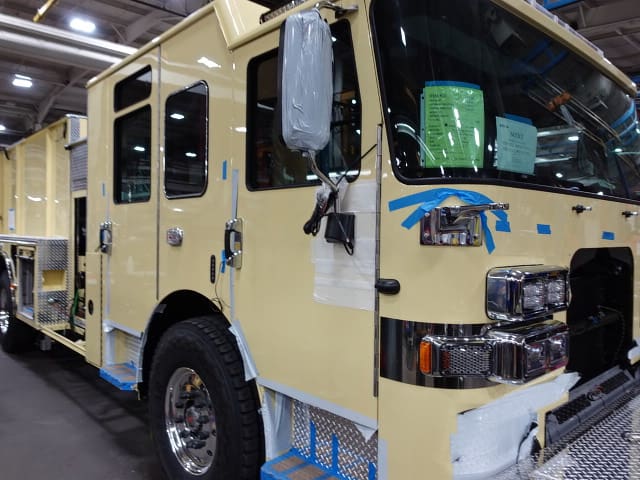

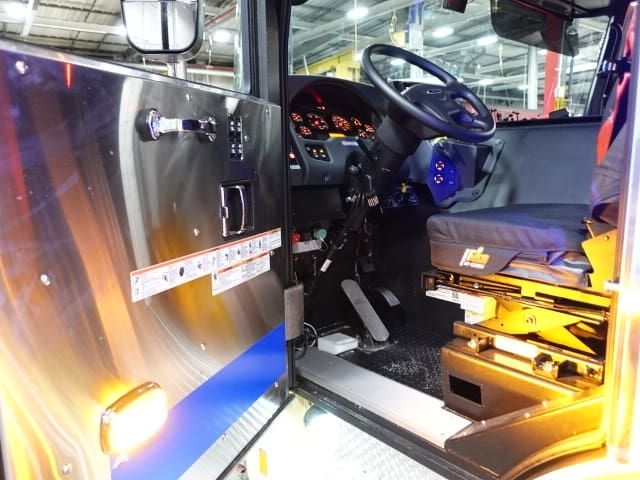

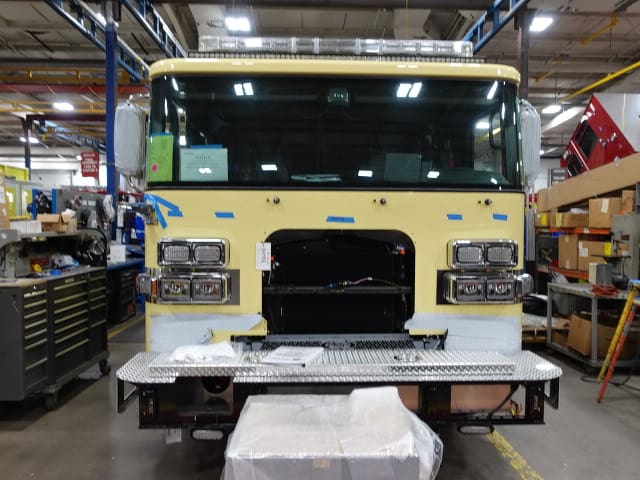

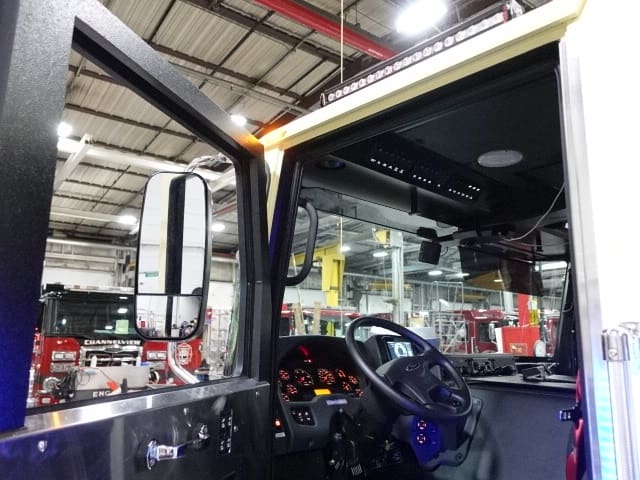

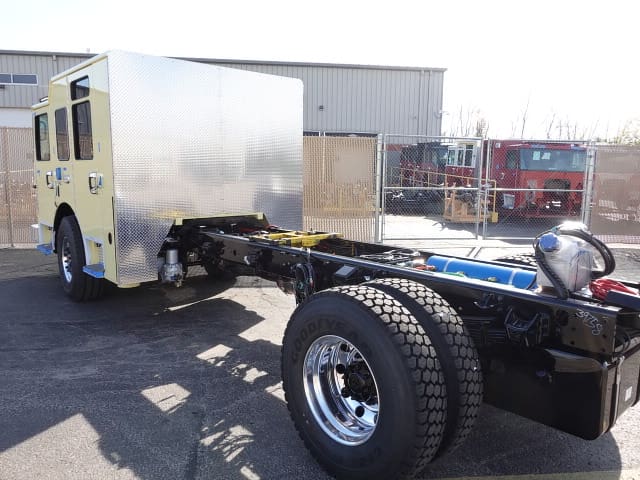

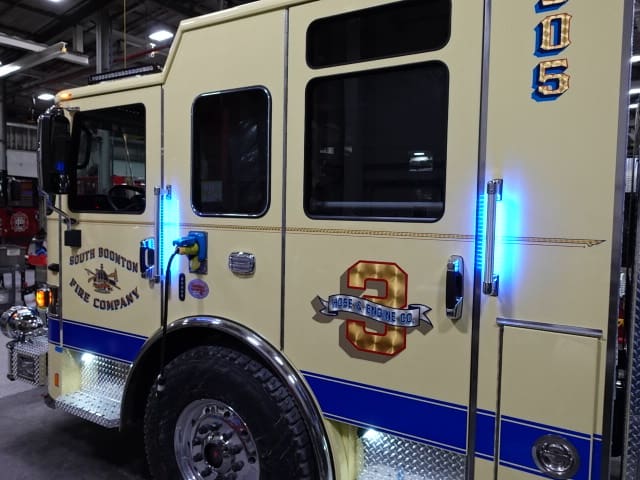

In this report, the apparatus completed final assembly and test followed by release to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.

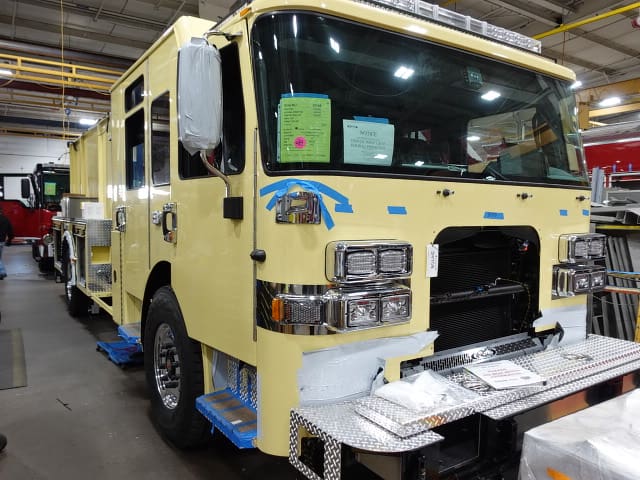

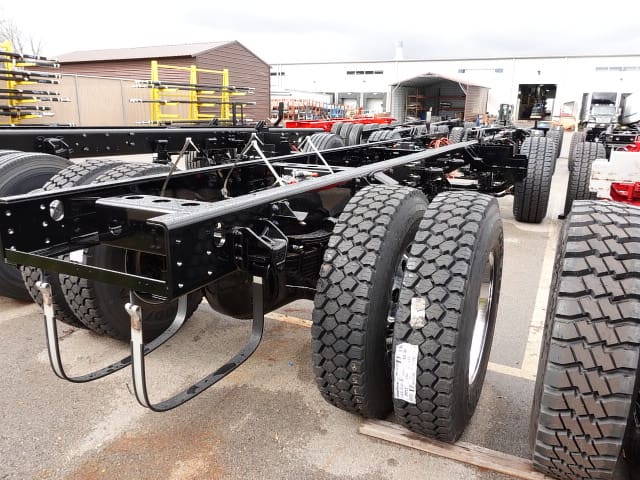

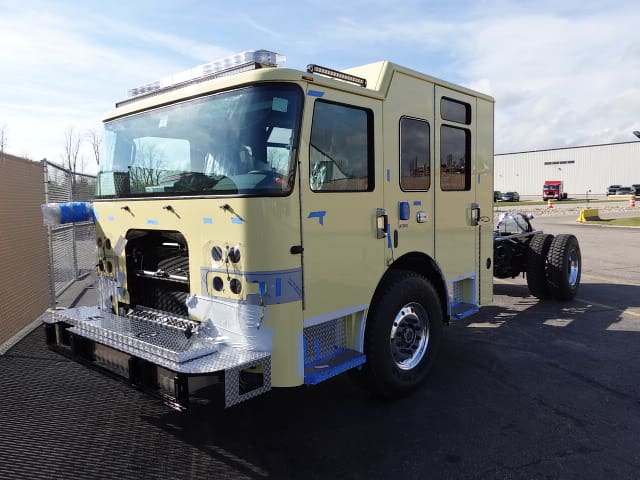

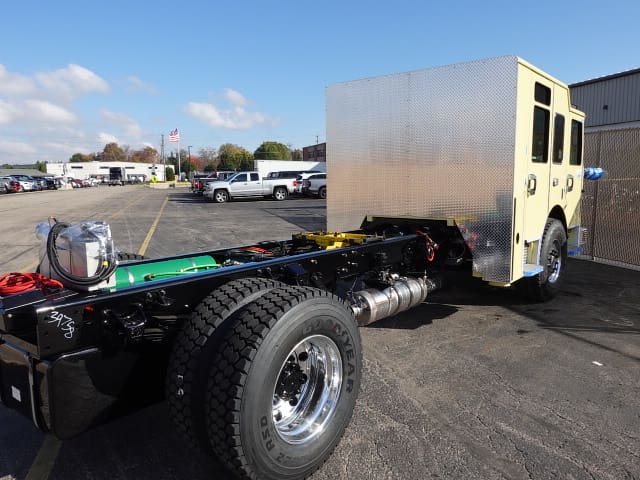

10-31-25

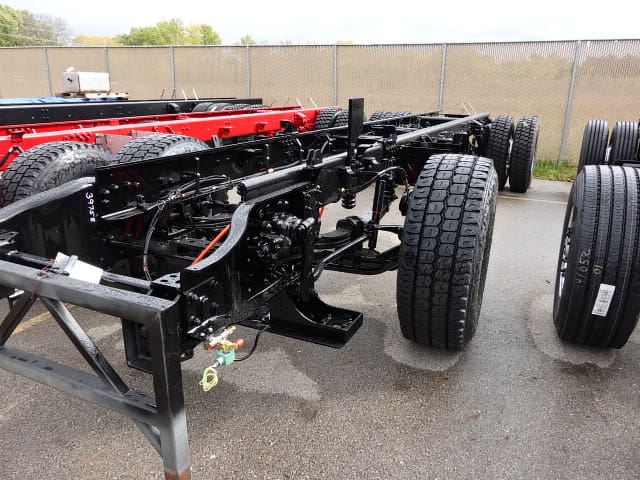

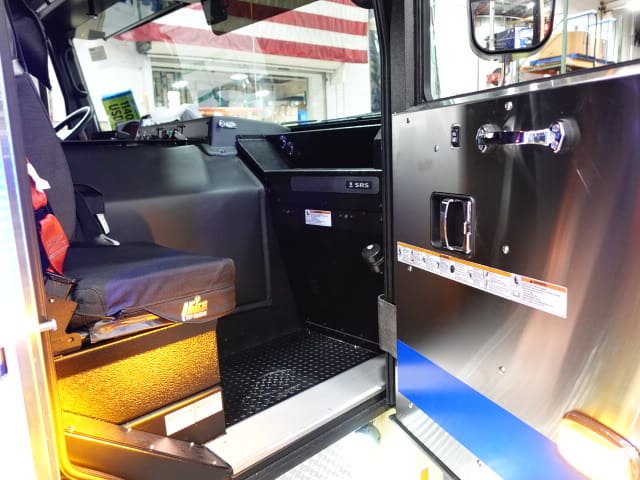

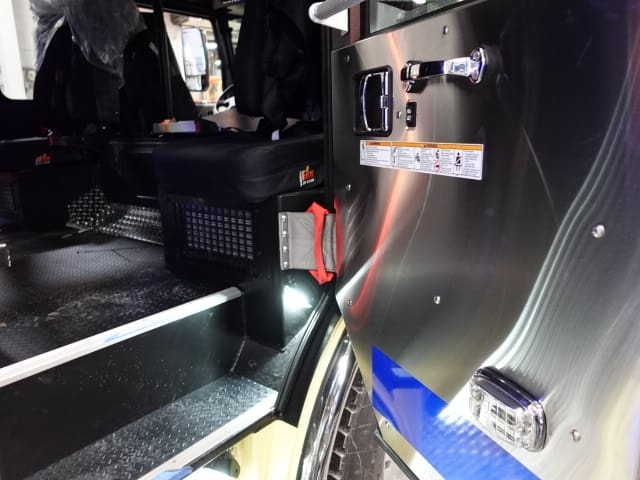

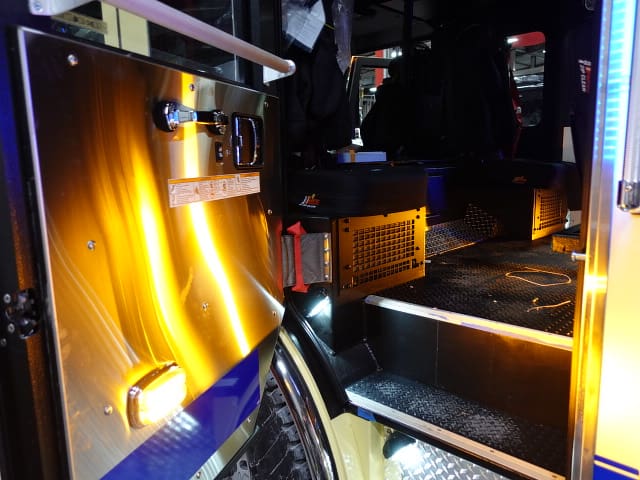

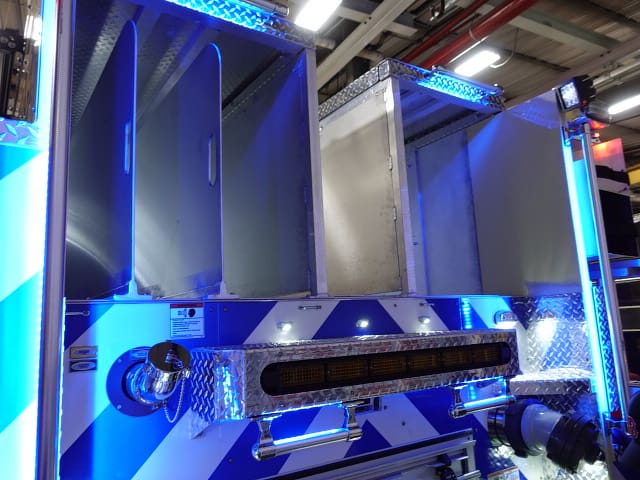

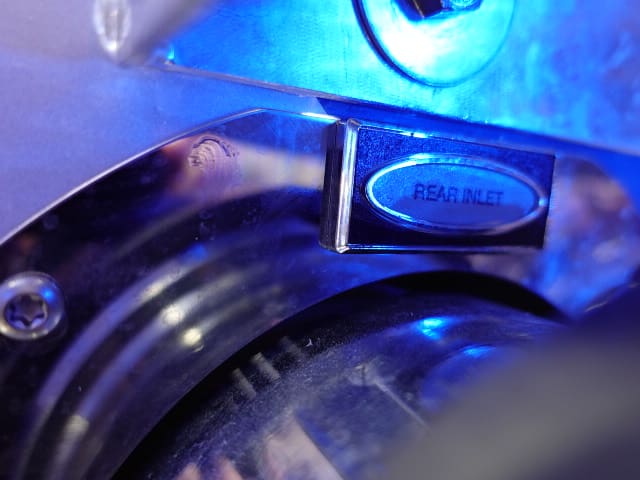

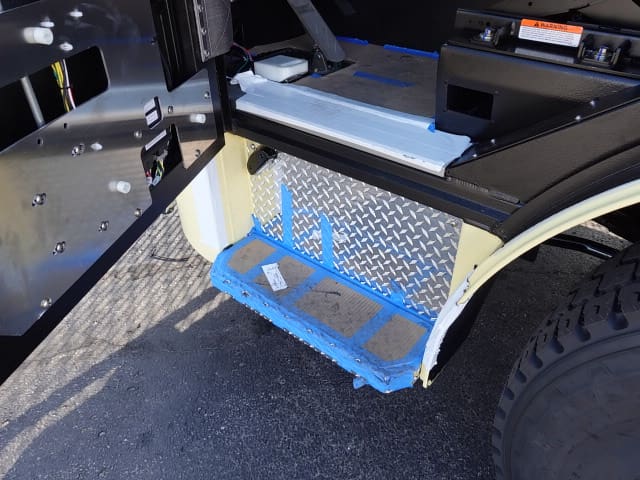

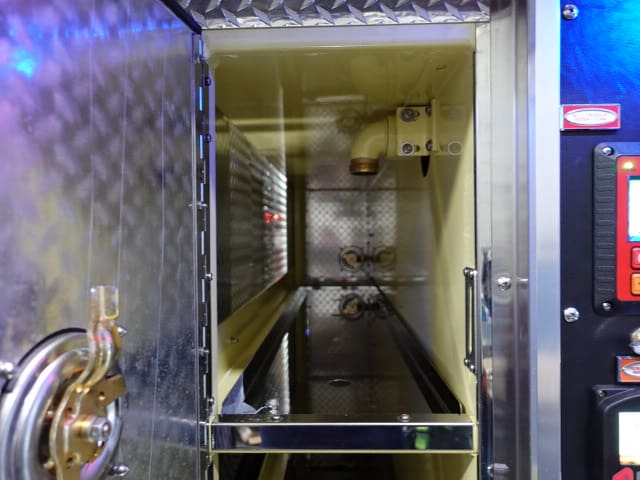

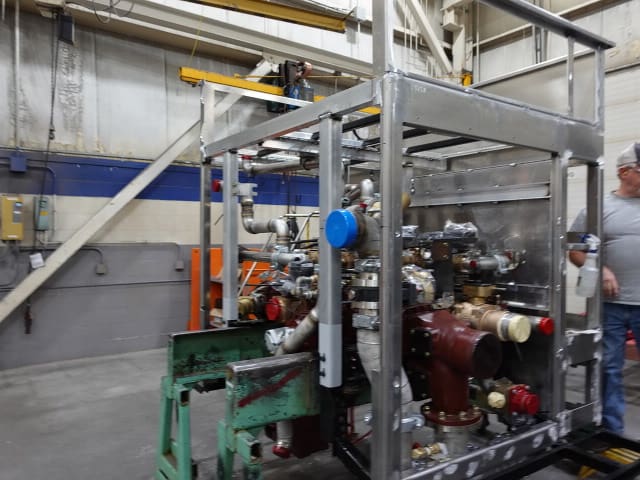

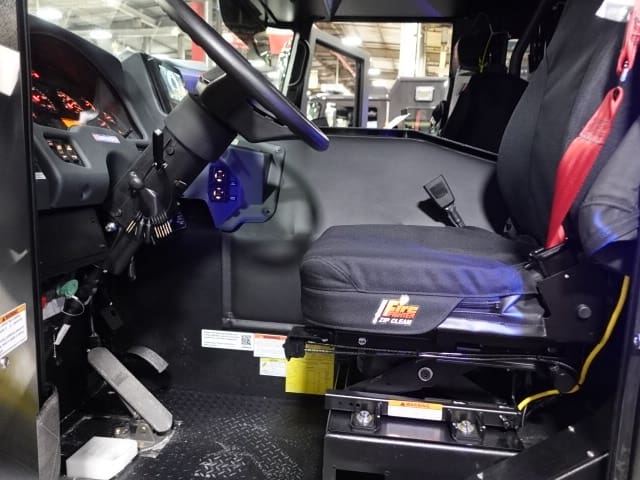

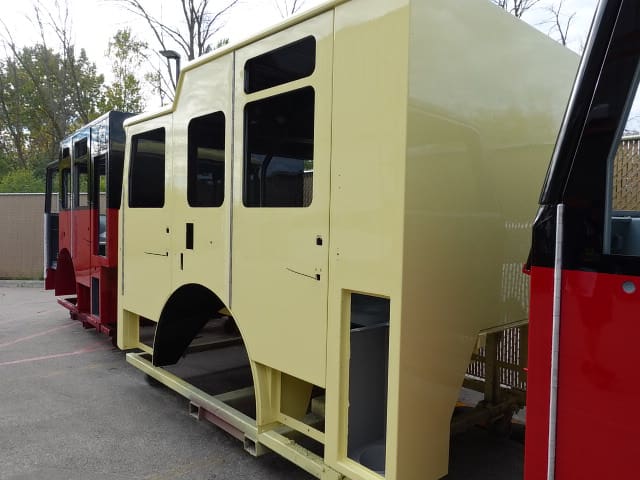

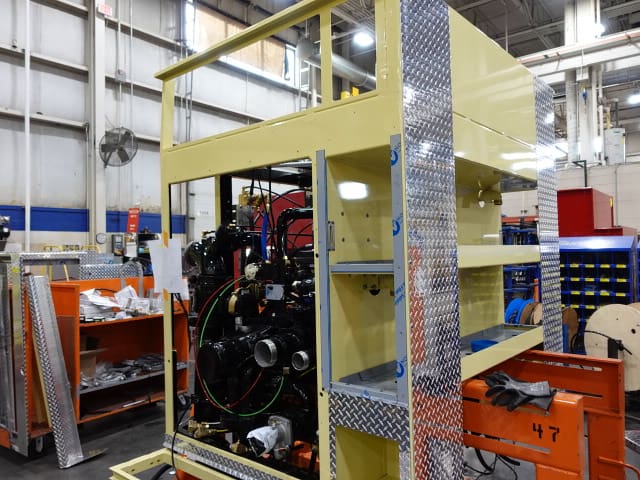

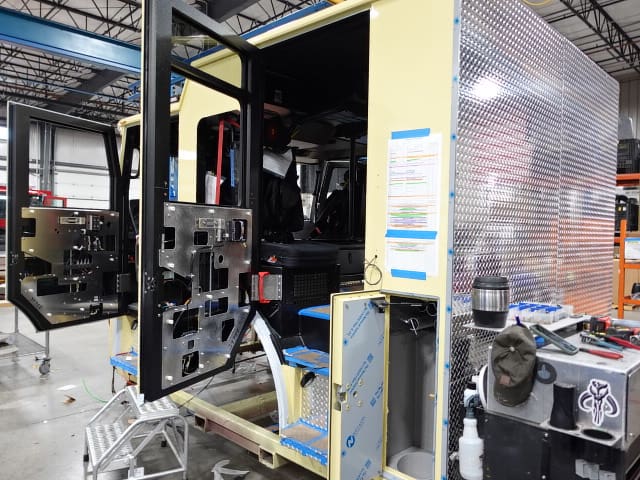

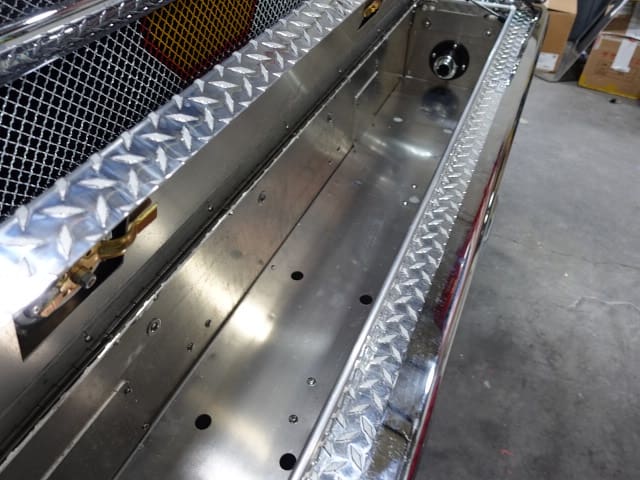

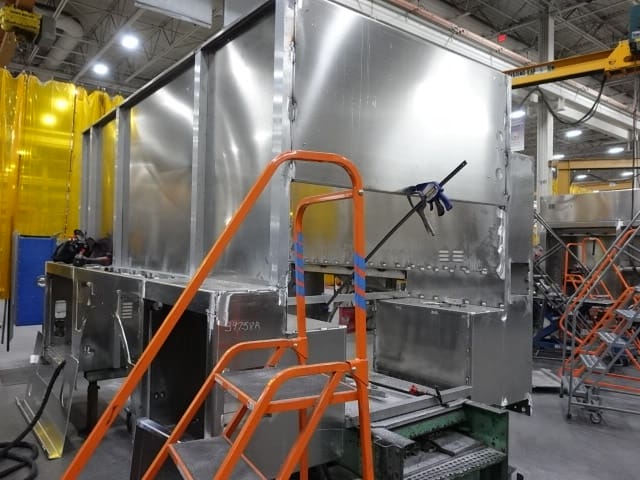

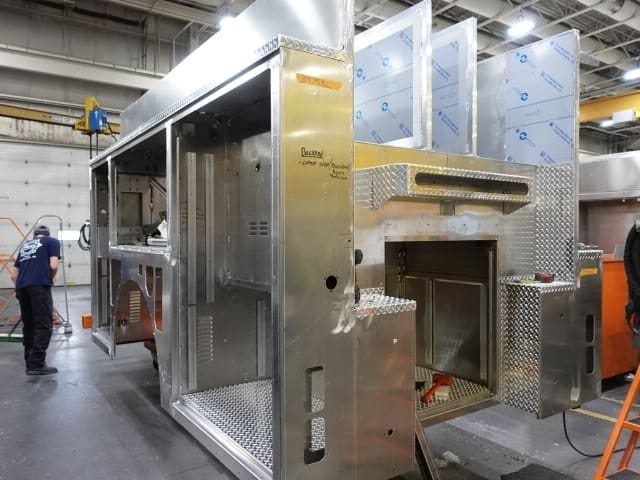

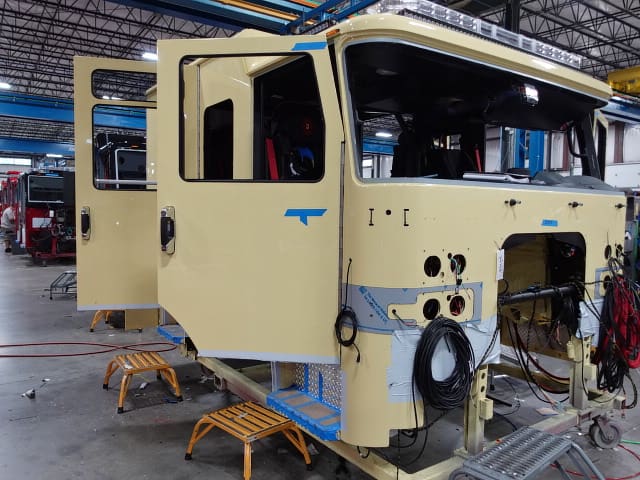

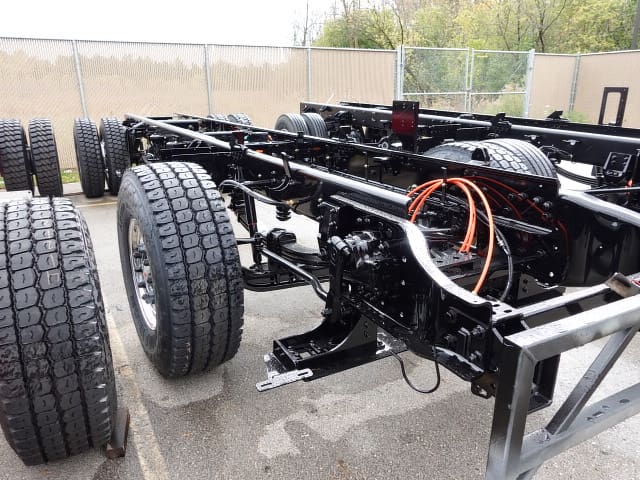

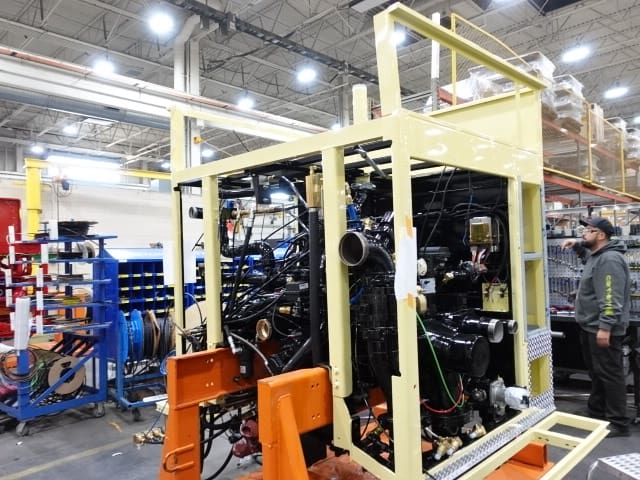

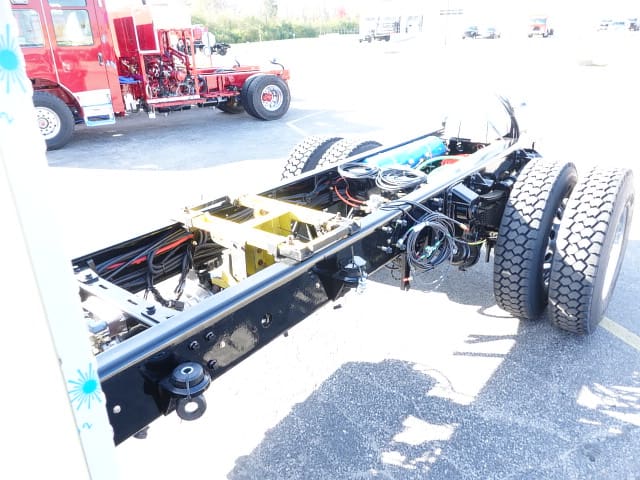

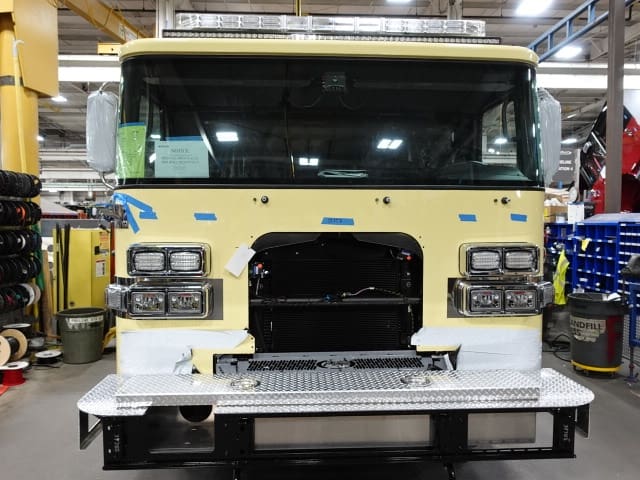

In this report, the cab completed initial assembly and was installed on the frame followed by the pump house and body being merged with the chassis at the start of initial apparatus assembly.
10-24-25

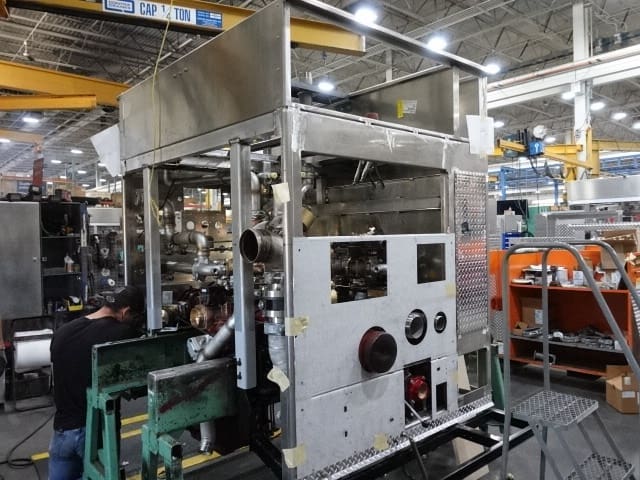

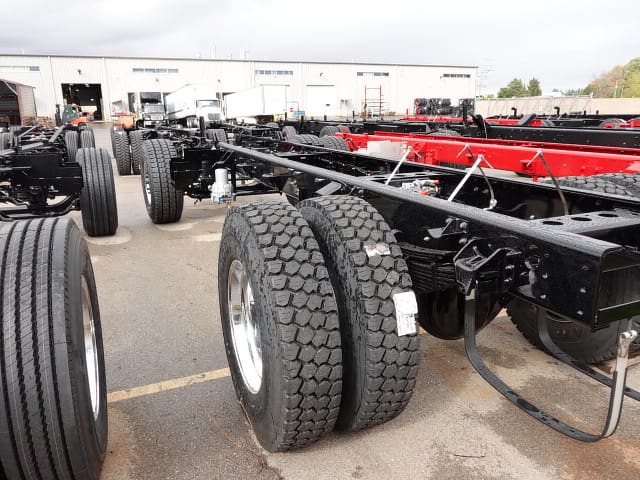

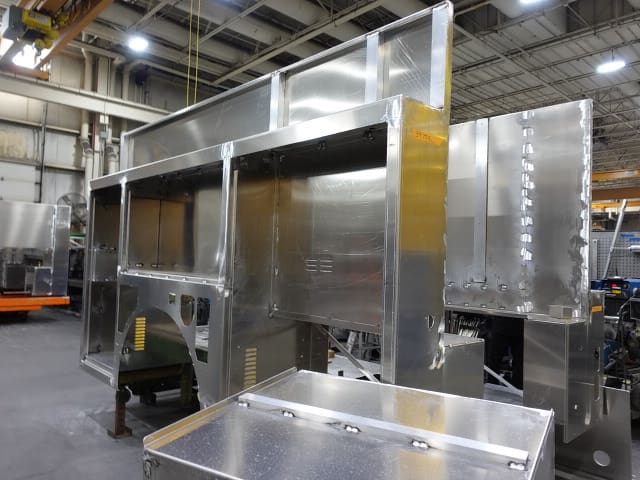

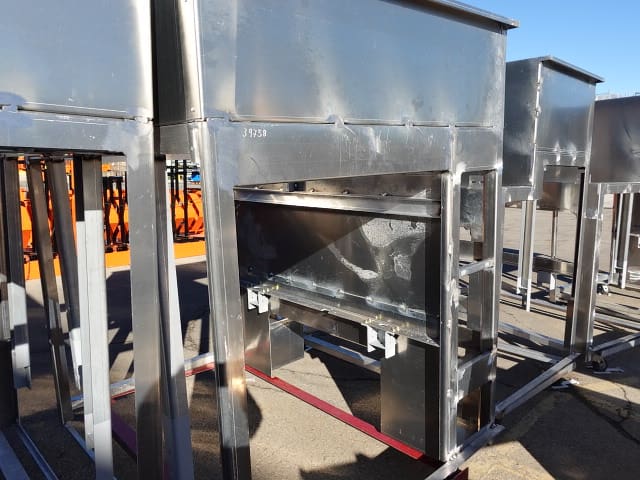

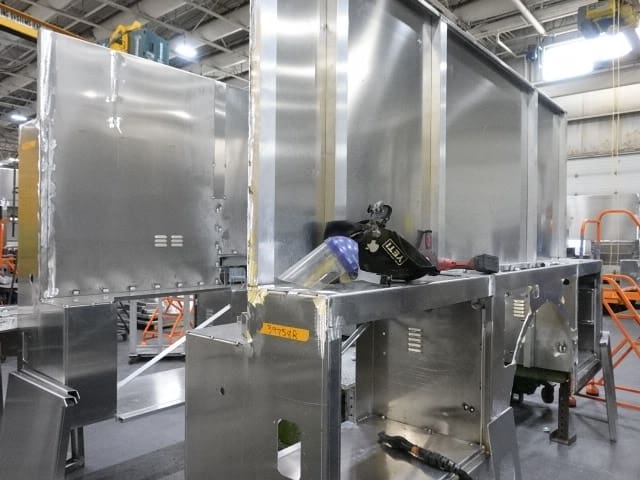

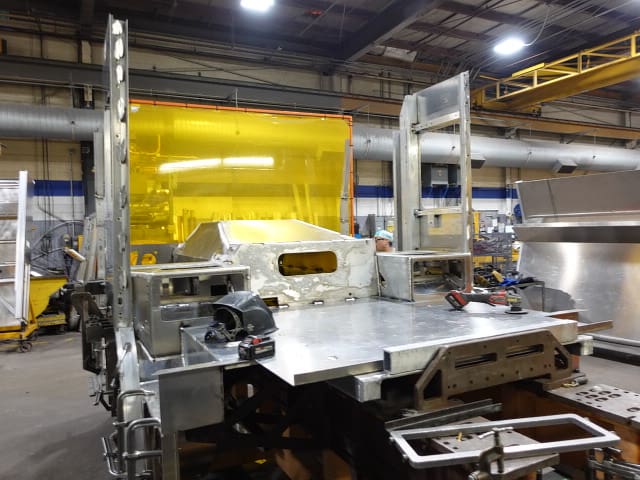

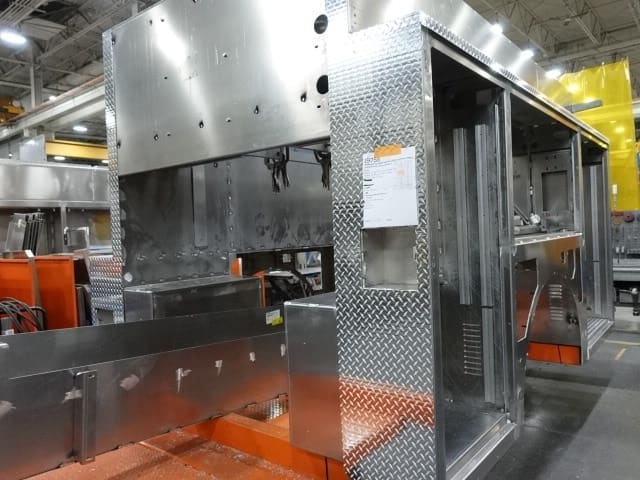

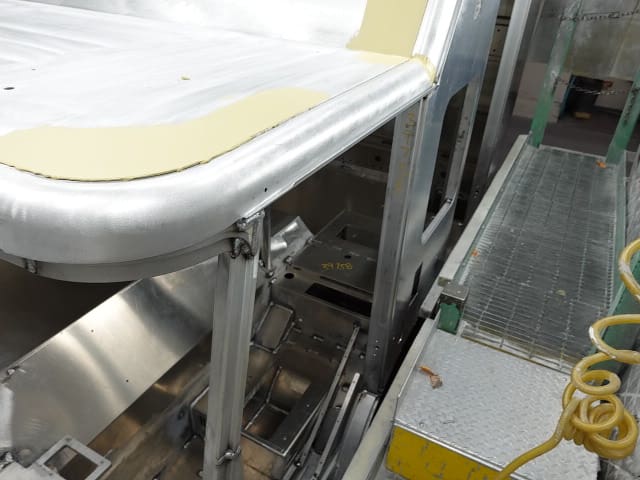

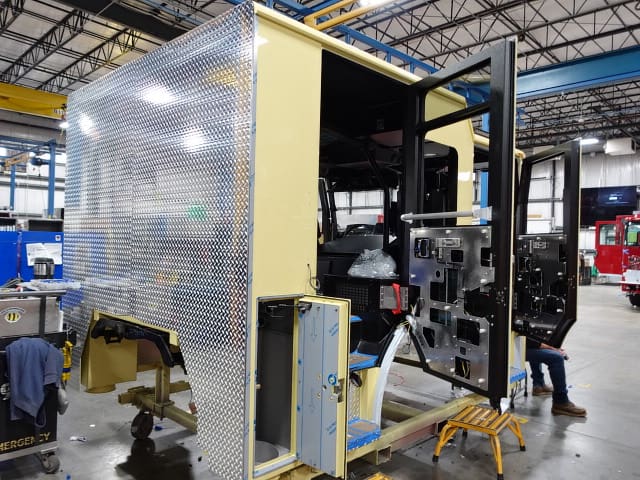

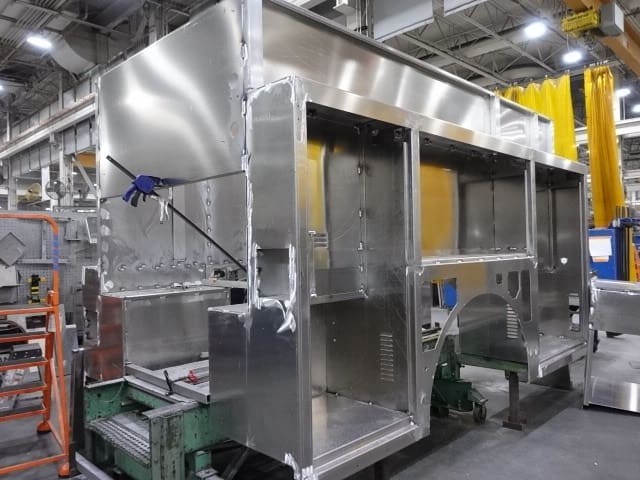

In this report, the cab began initial assembly, the frame build began, the pump house continued initial assembly, and the body continued the fabrication process.

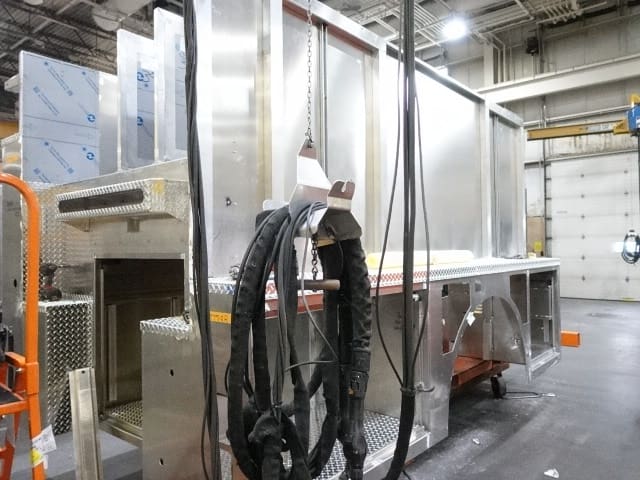

10-17-25

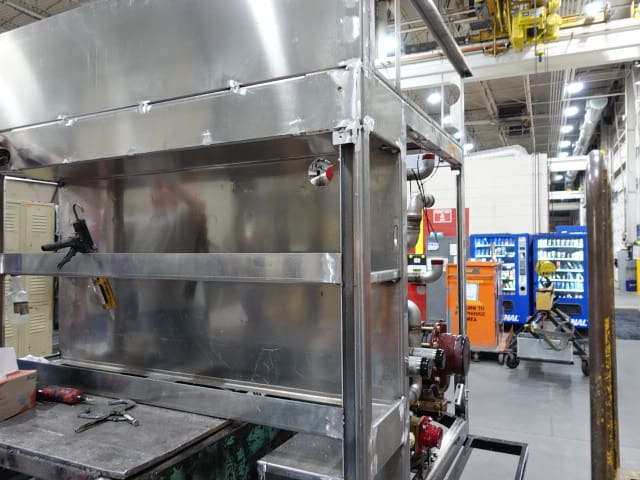

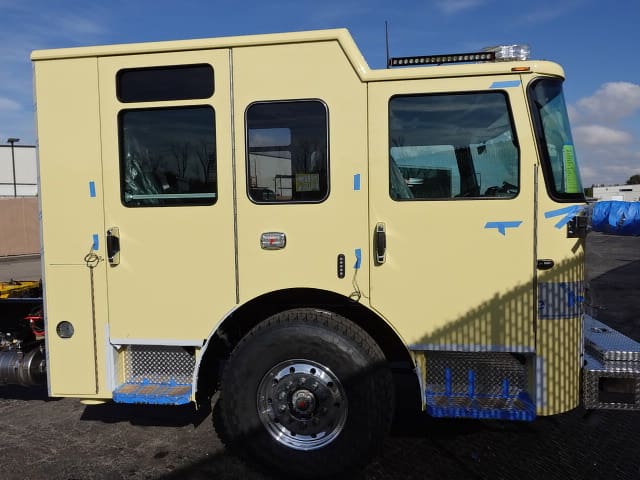

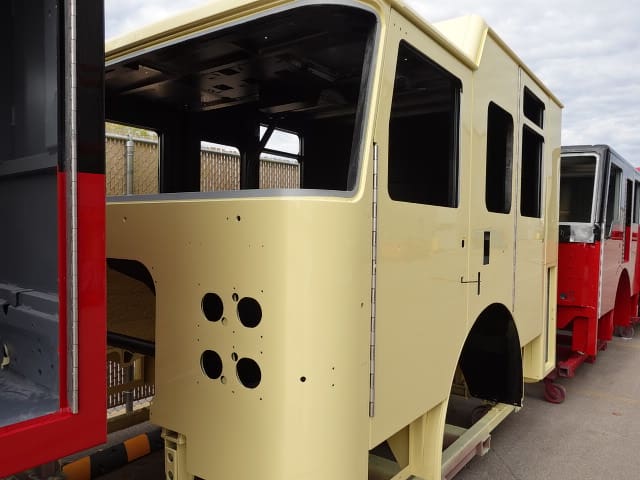

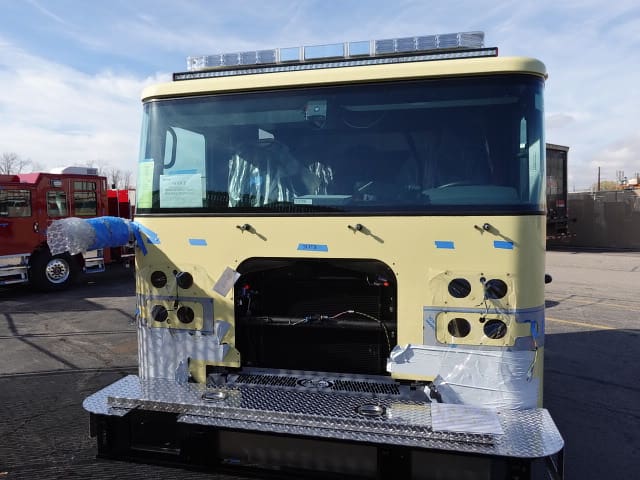

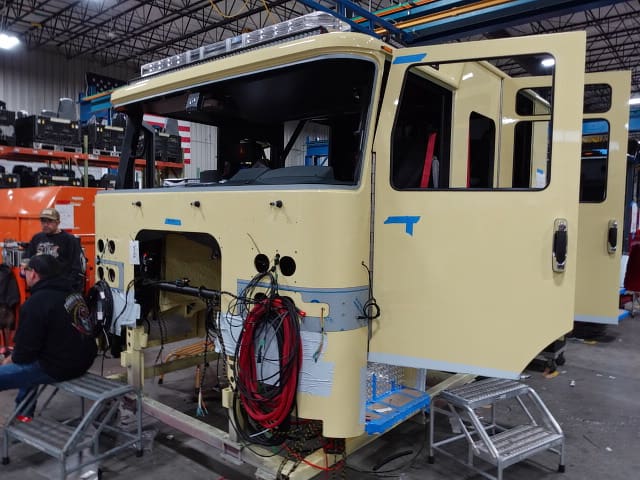

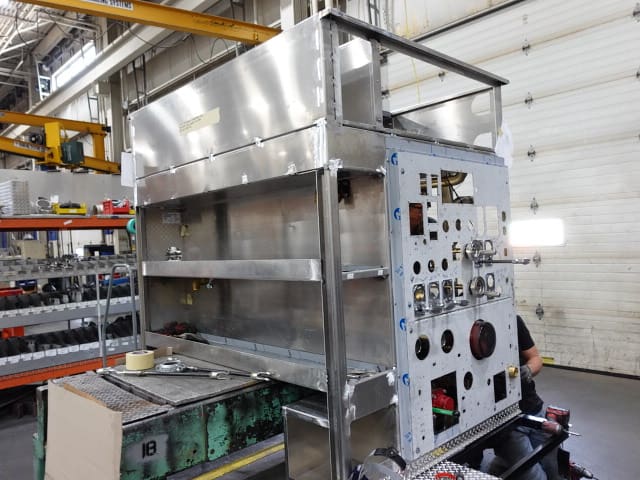

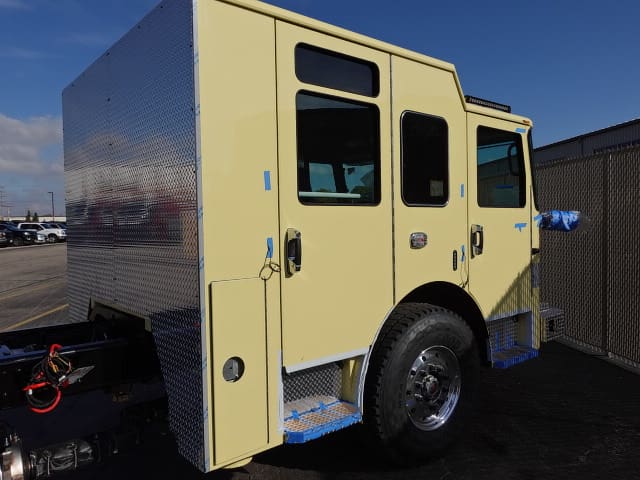

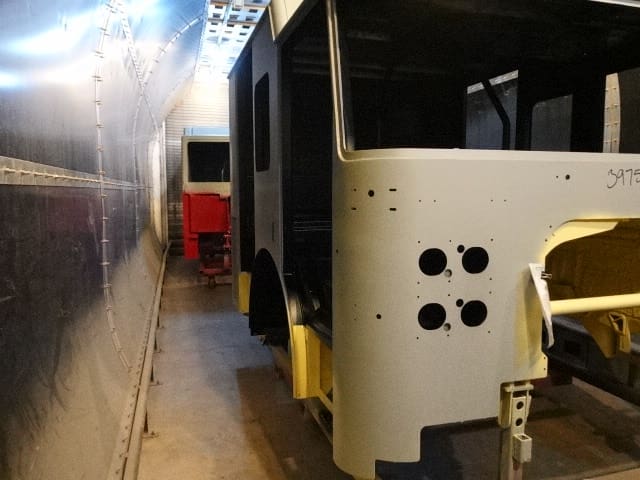

In this report, the cab completed paint, the pump house began initial assembly, and the body began fabrication.

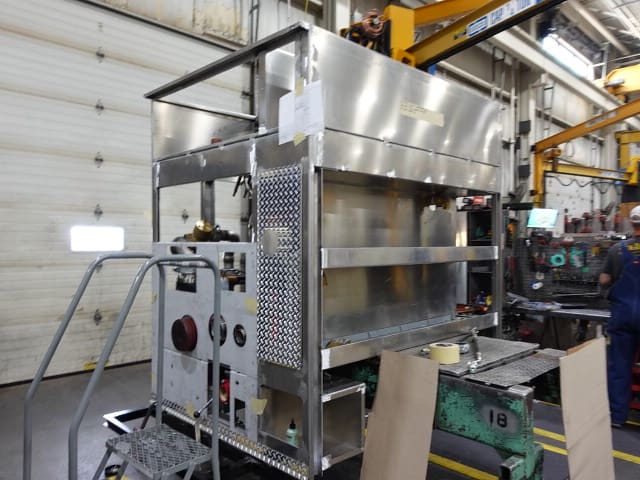

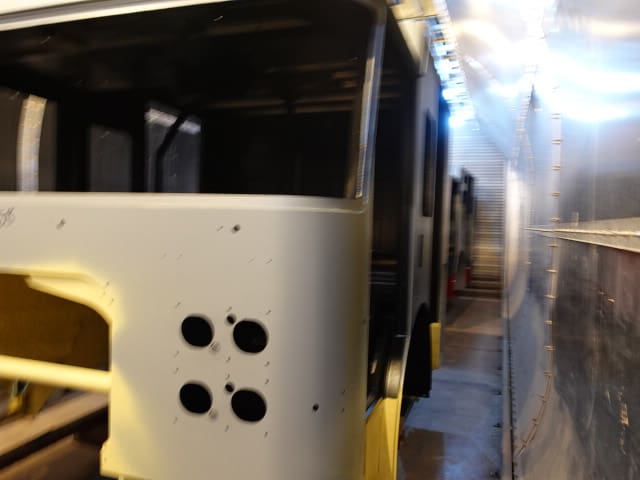

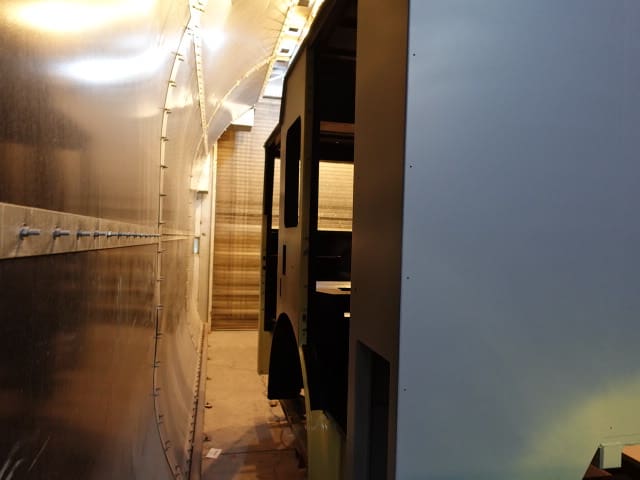

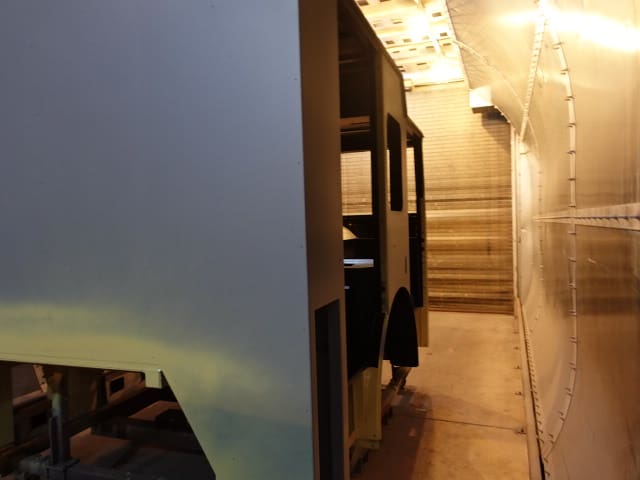

10-10-25

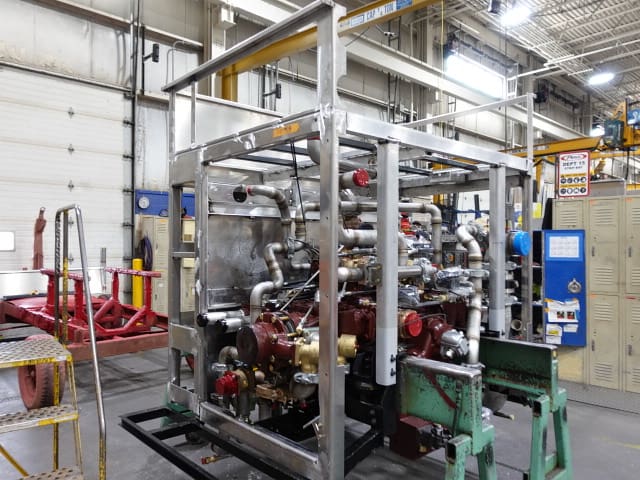

In this report, the cab continued through paint while the pump house structure was fabricated and staged.
10-03-25
In this report, the cab completed fabrication and began the paint process with metal finishing.
09-26-25

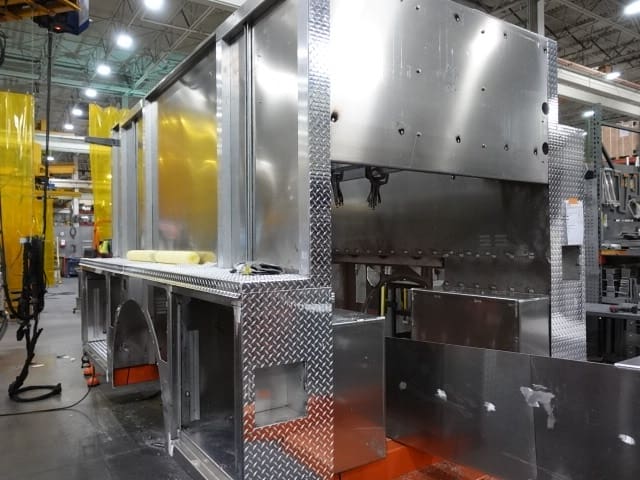

This new Pierce apparatus is now in production!

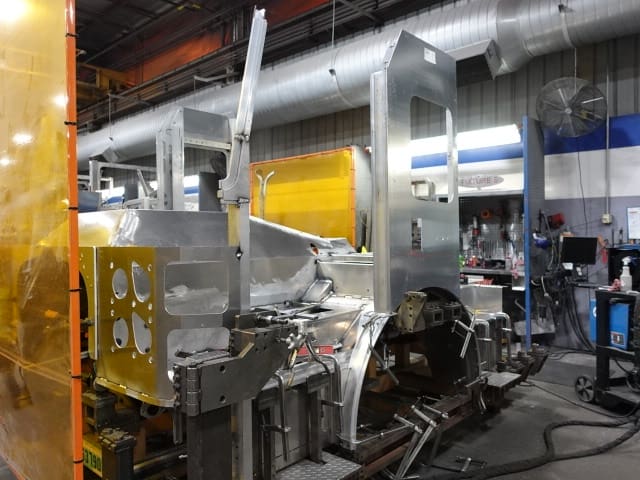

In this report, the cab began fabrication.
