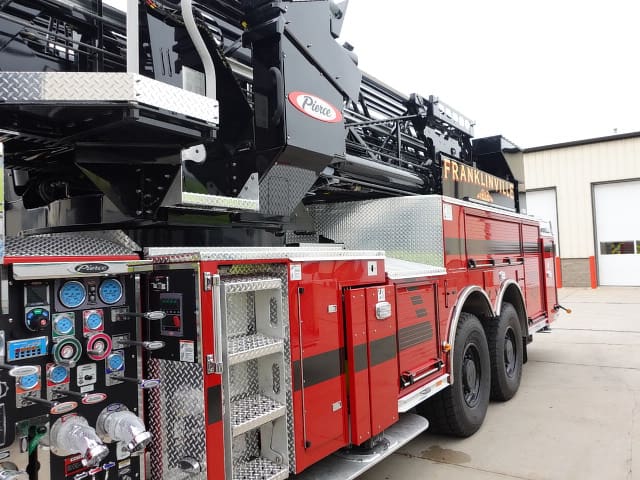

09-12-25

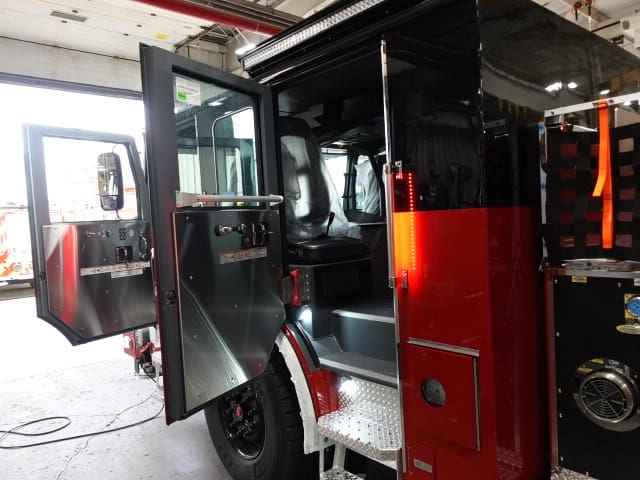

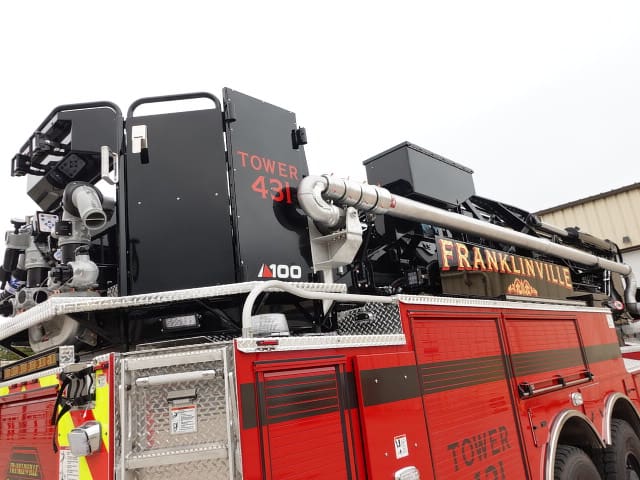

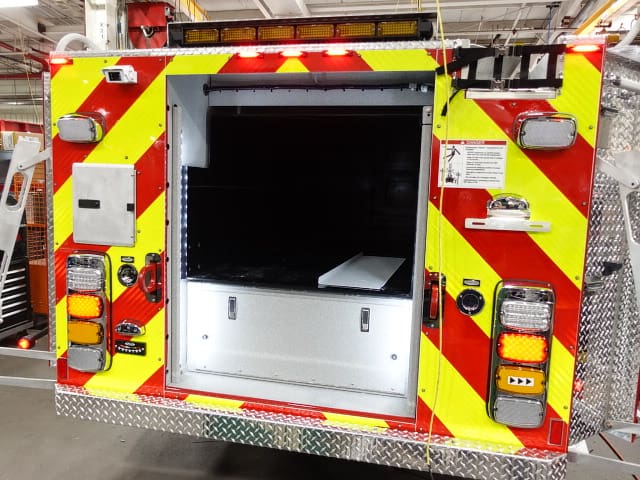

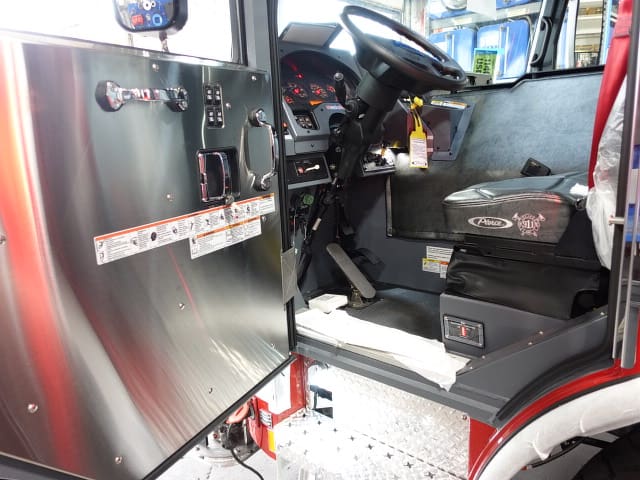

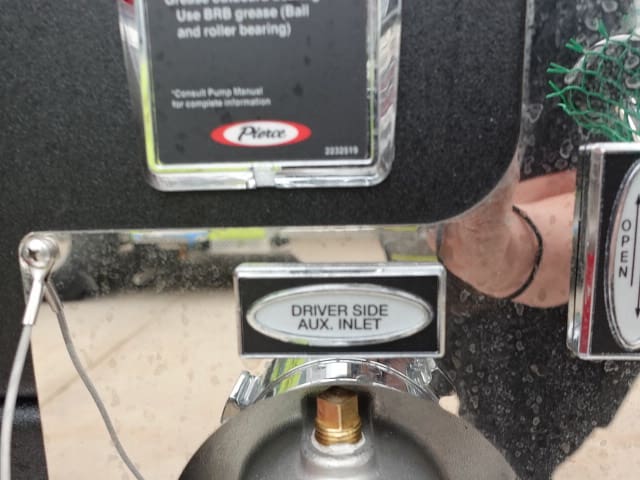

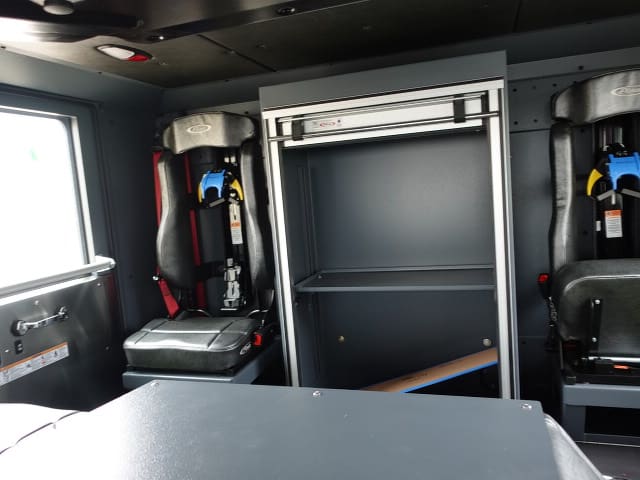

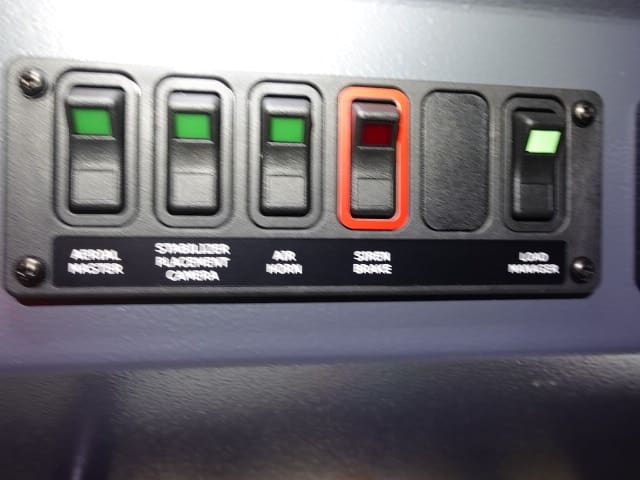

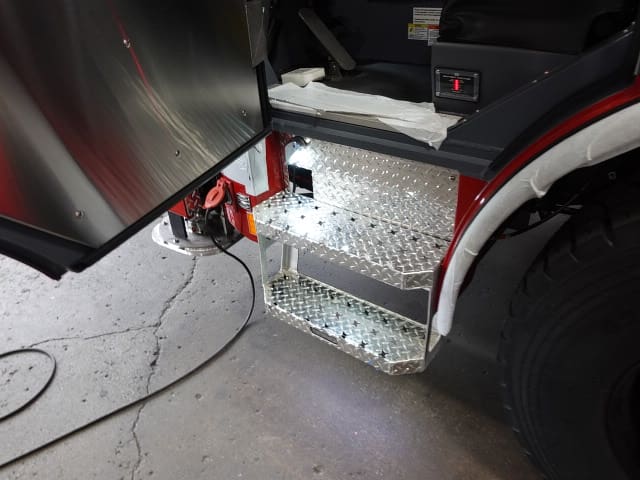

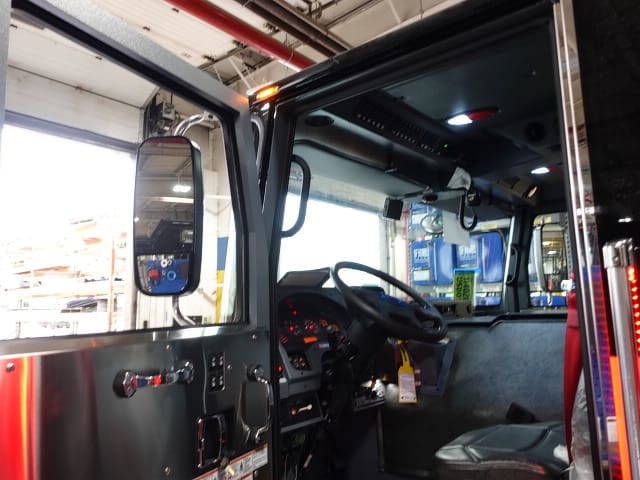

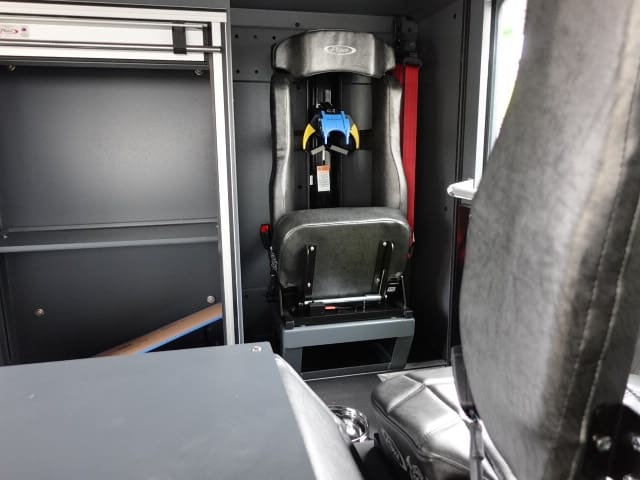

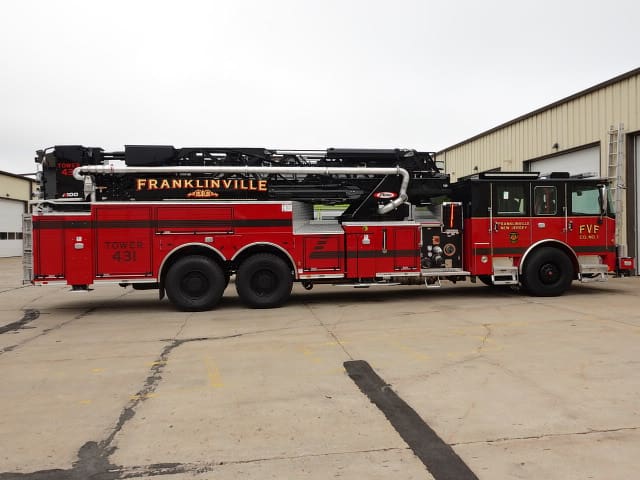

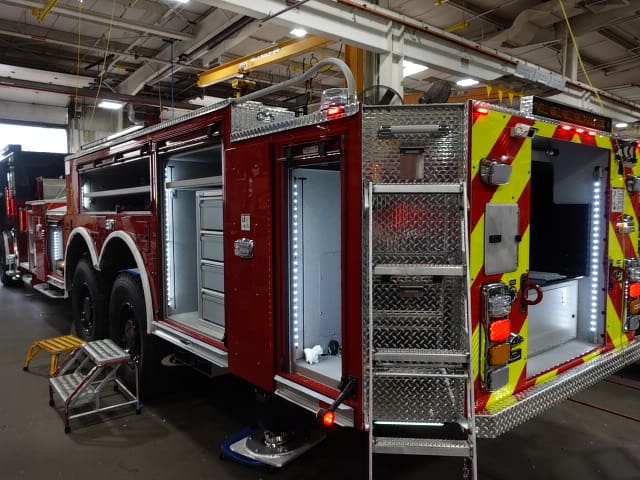

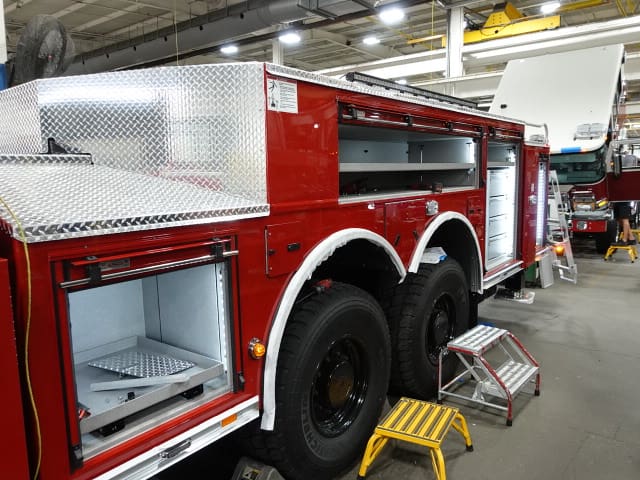

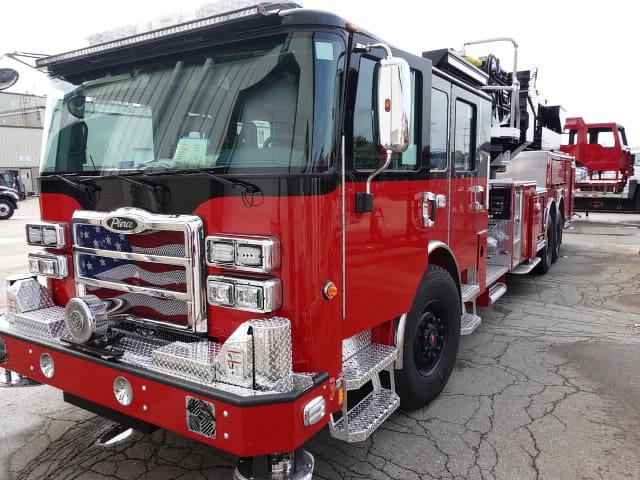

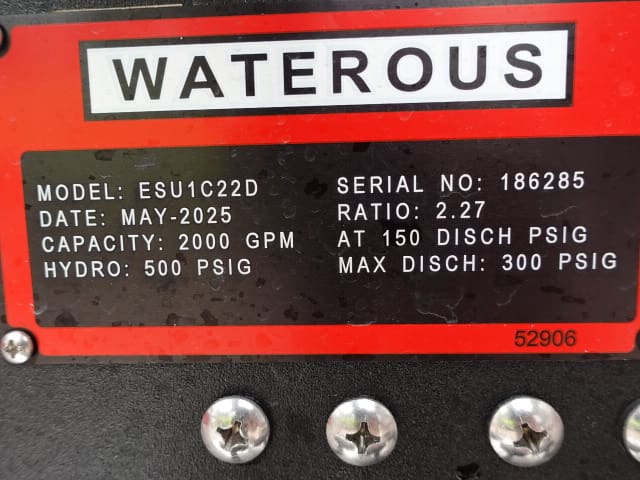

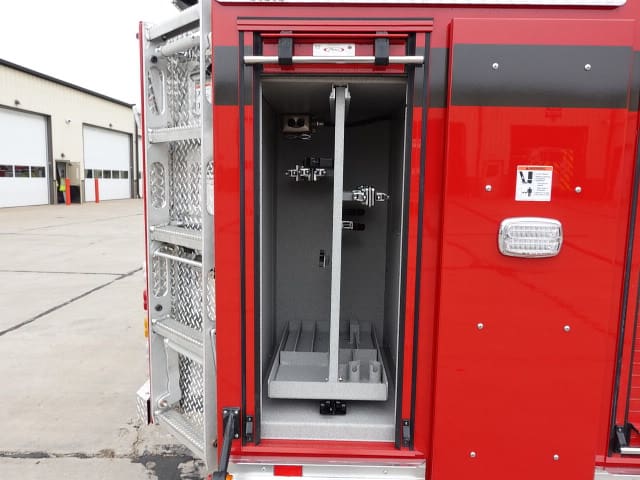

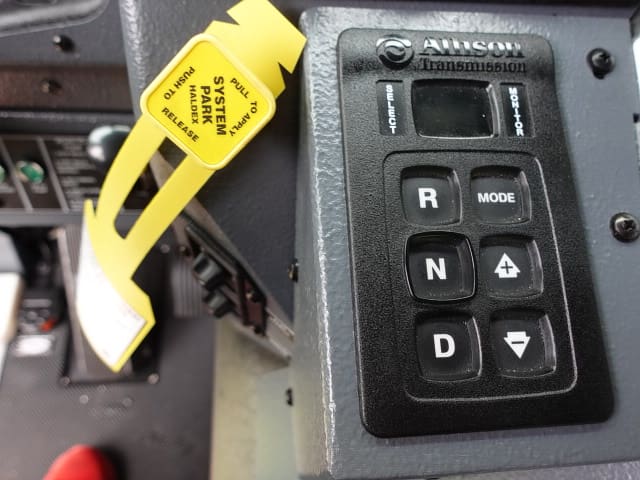

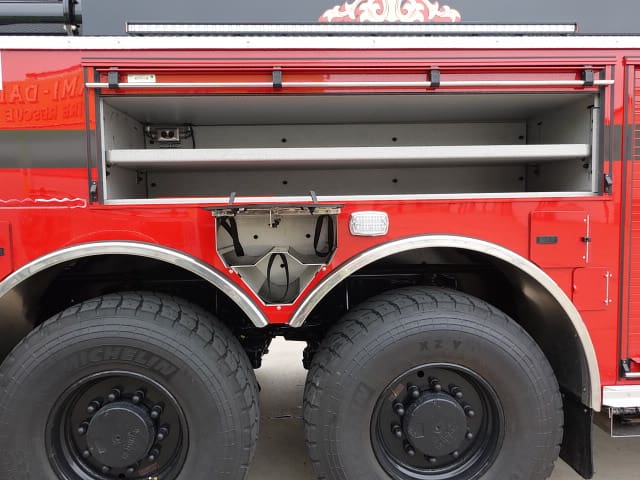

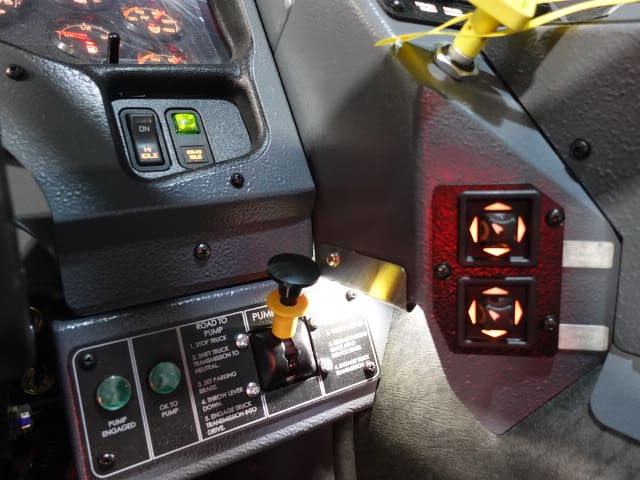

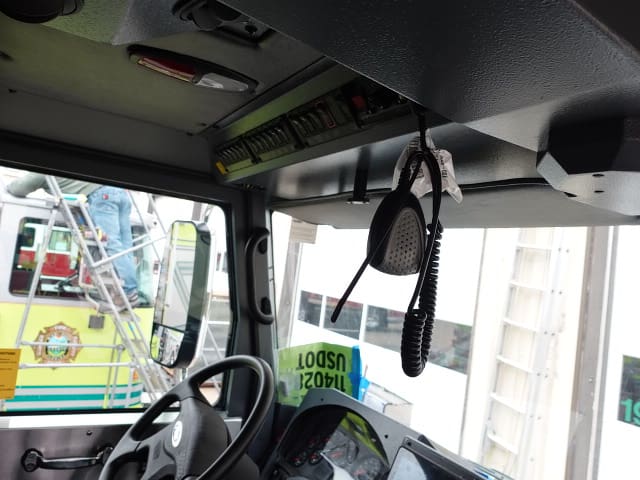

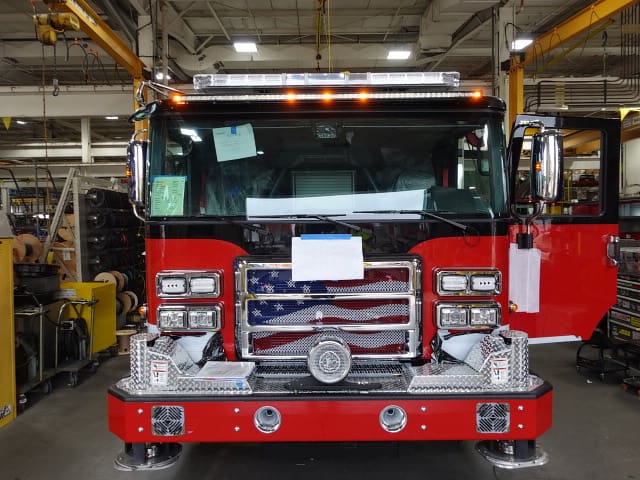

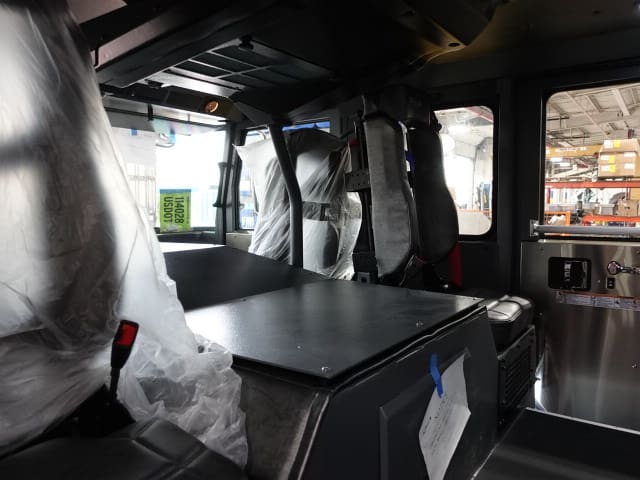

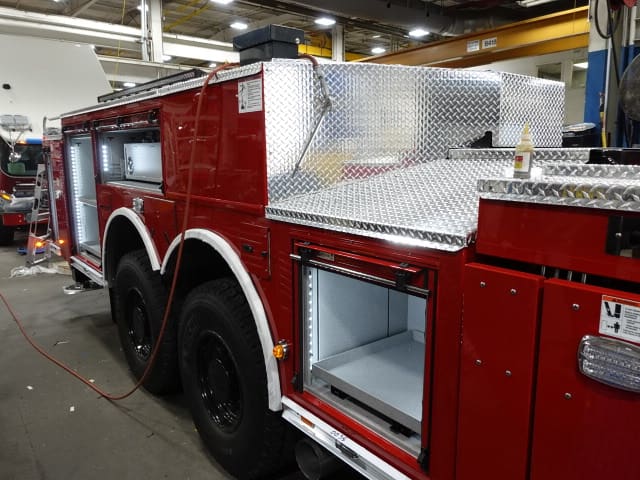

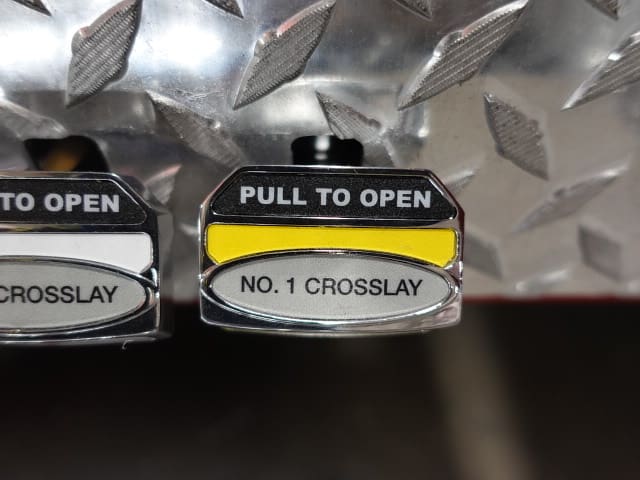

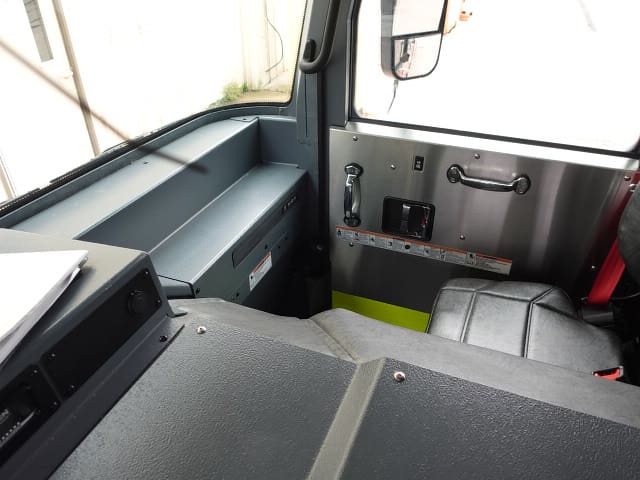

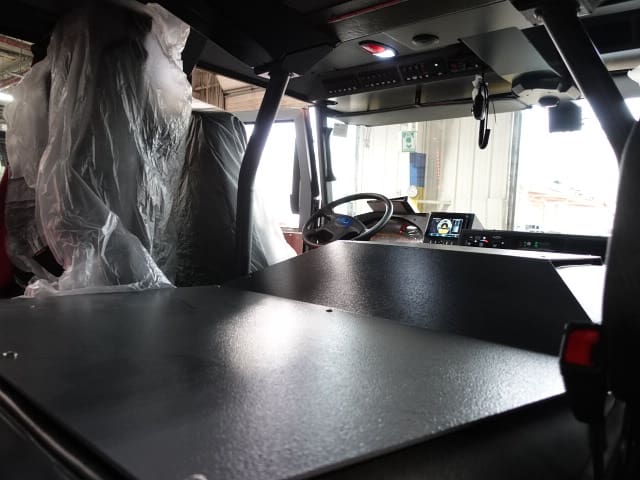

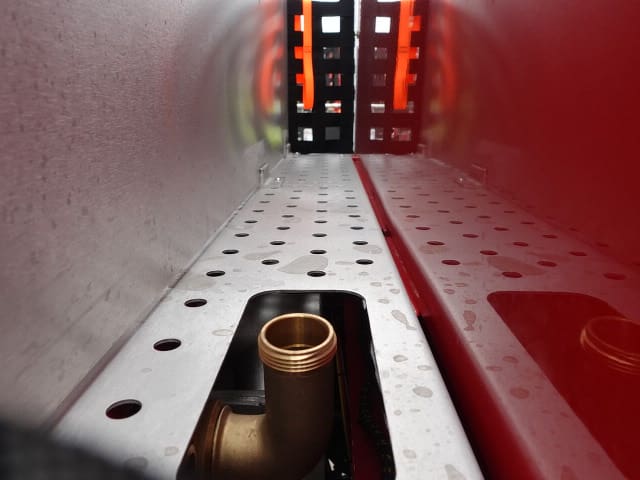

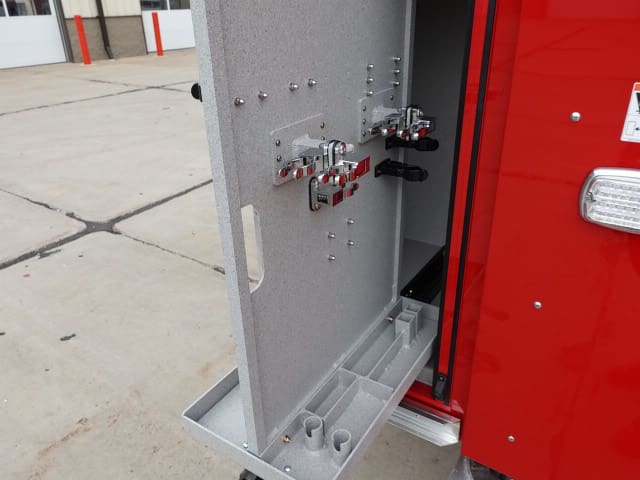

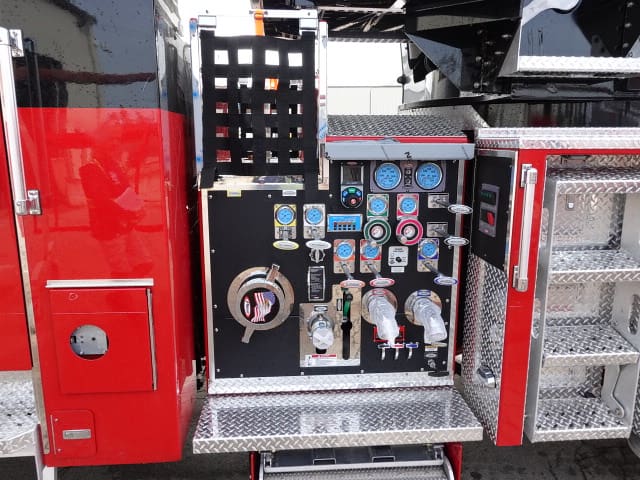

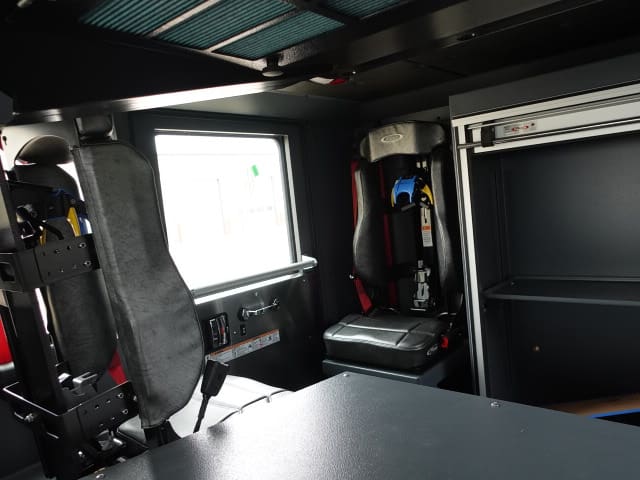

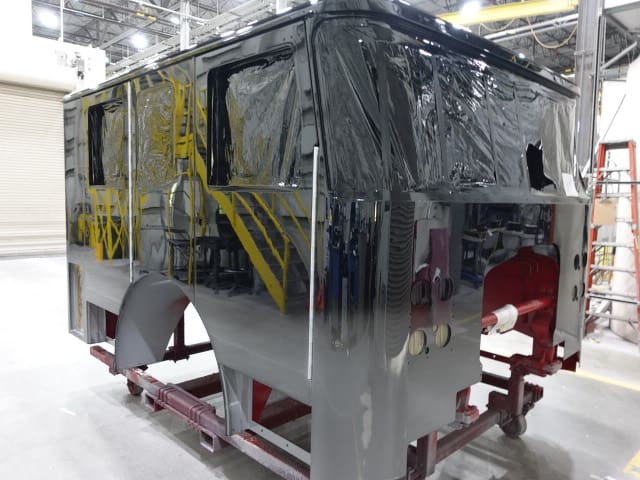

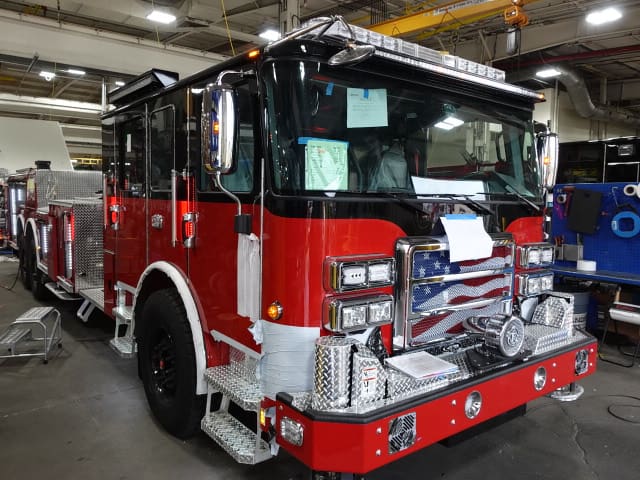

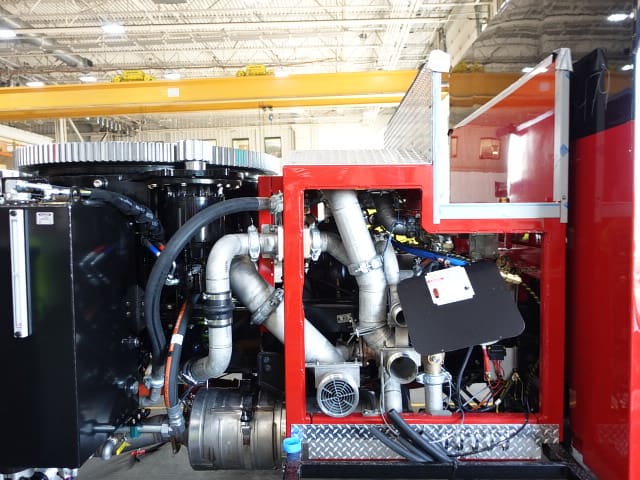

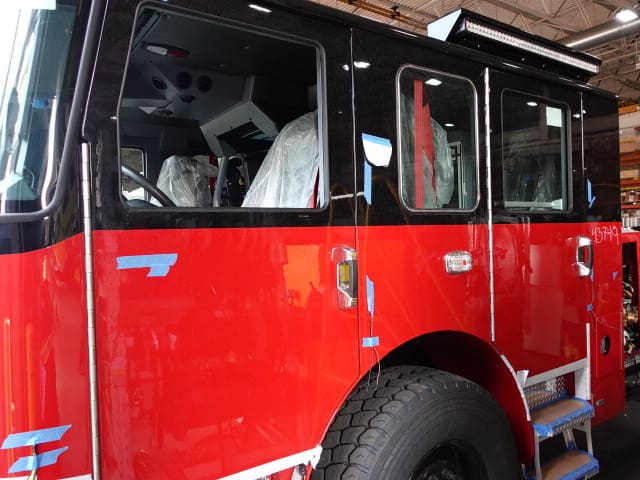

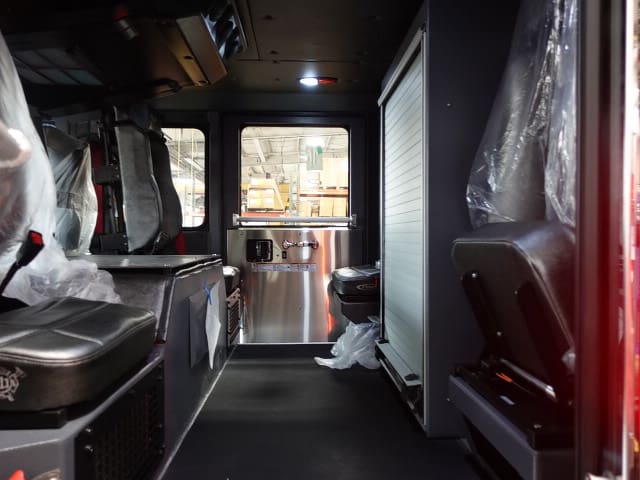

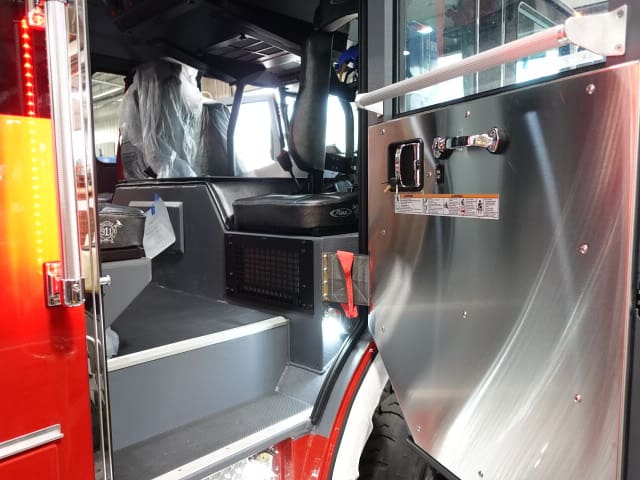

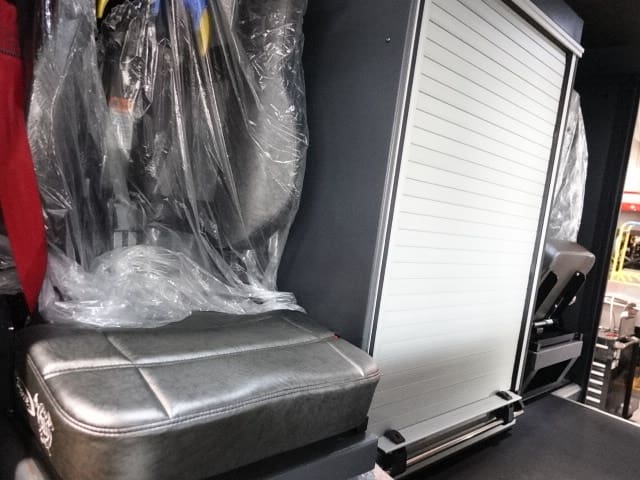

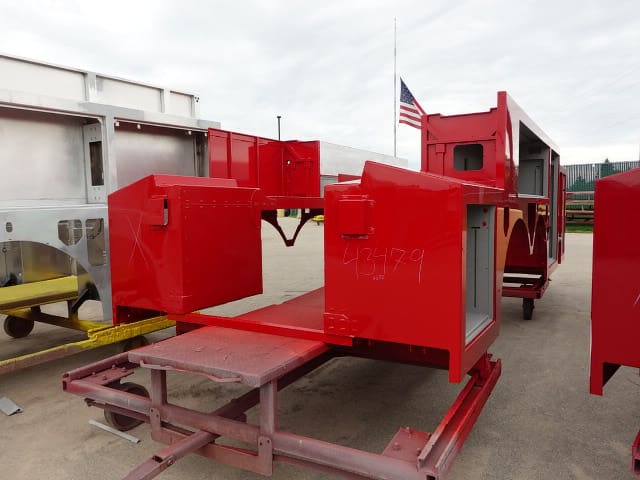

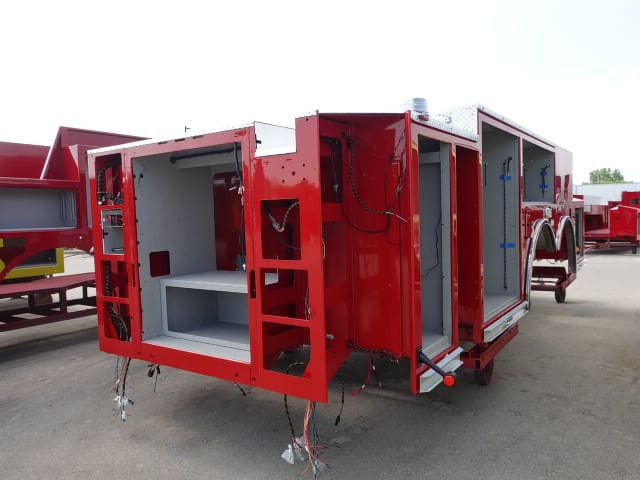

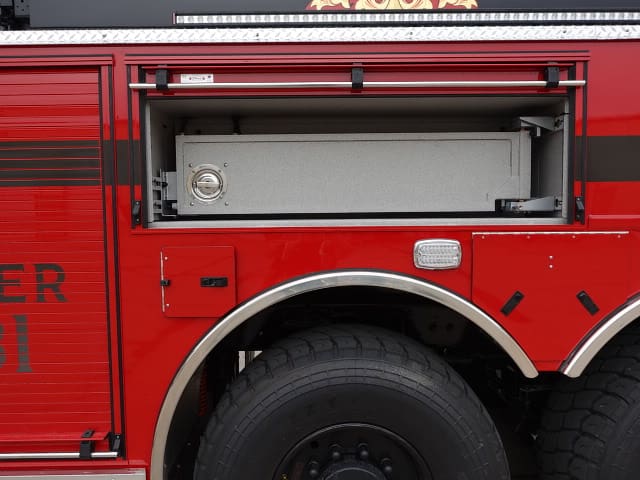

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.
08-22-25

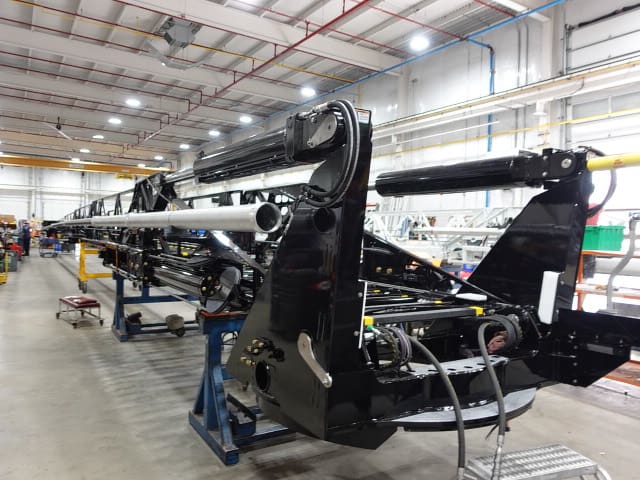

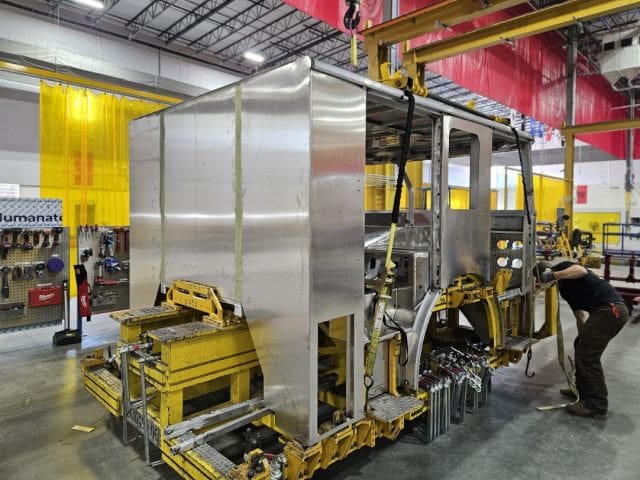

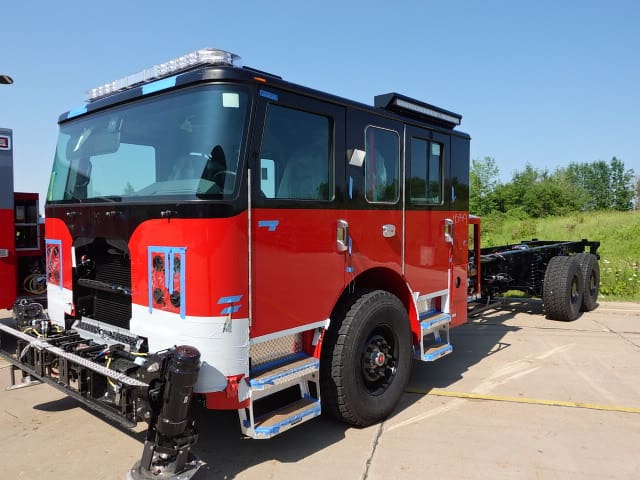

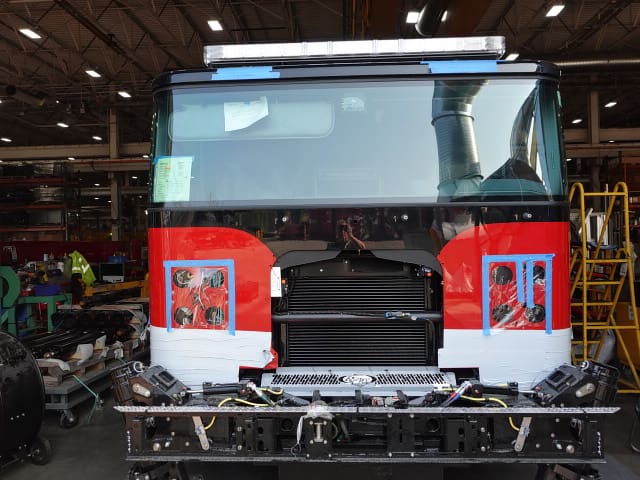

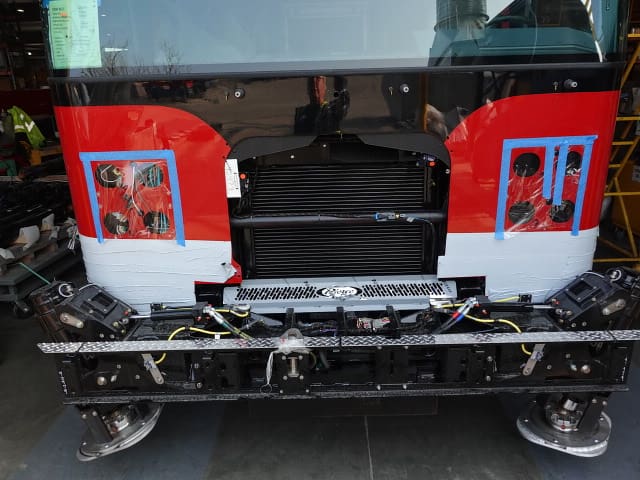

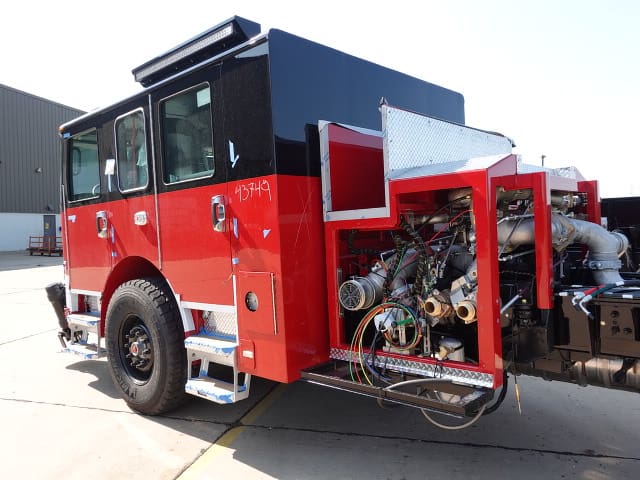

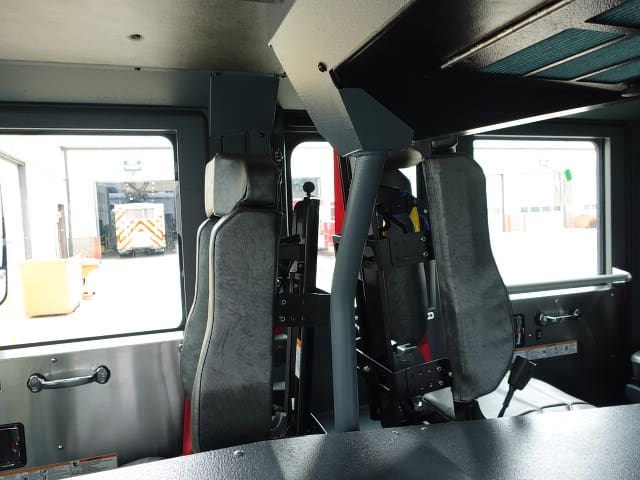

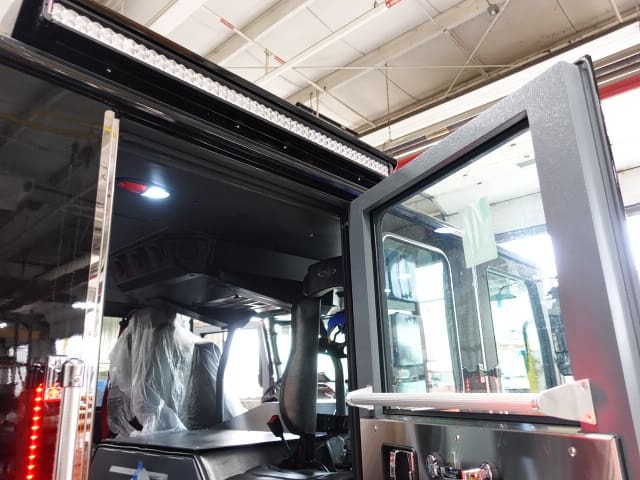

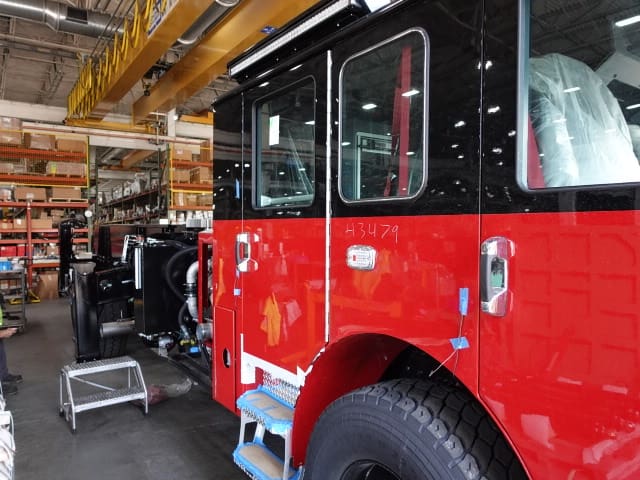

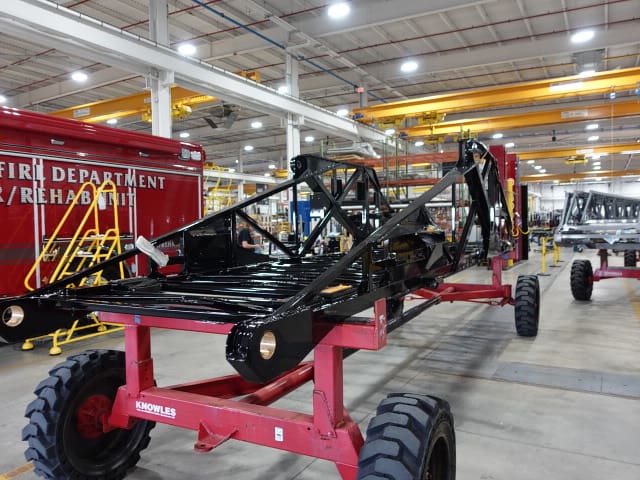

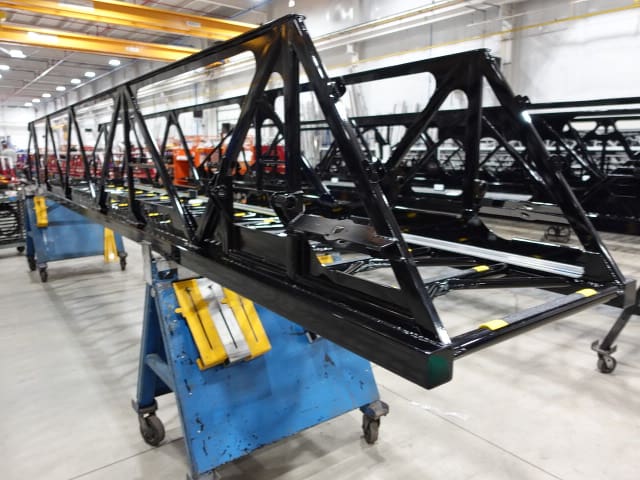

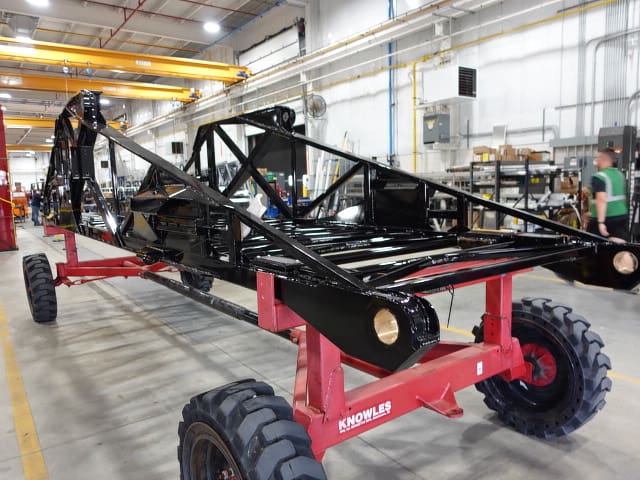

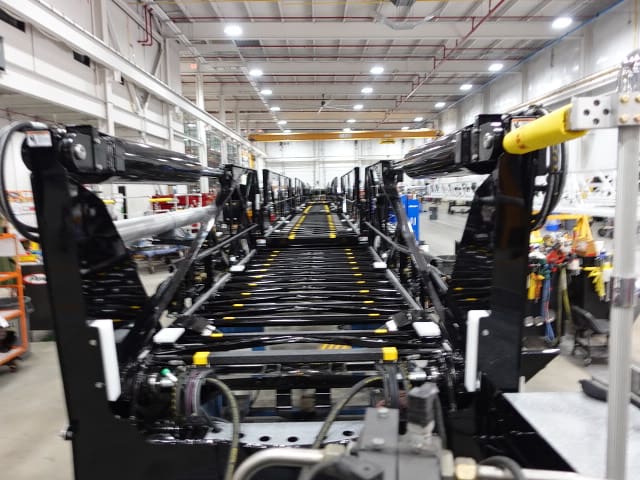

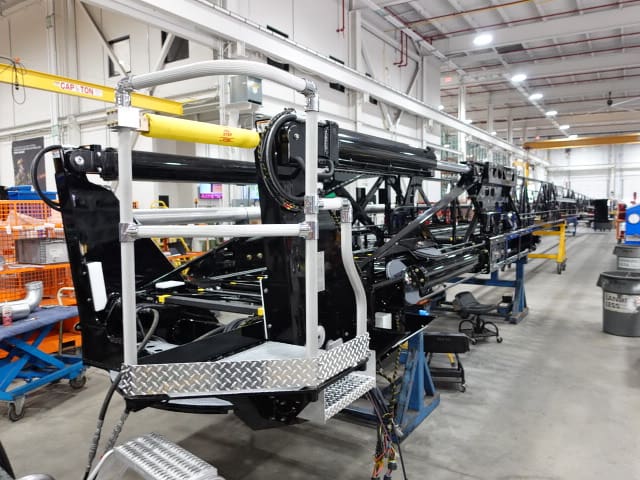

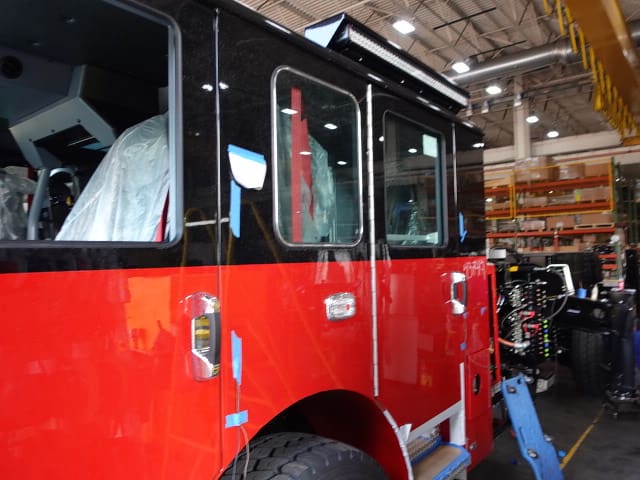

In this report, the turntable module was installed and your apparatus continued final assembly while the aerial device continued initial assembly.
08-15-25

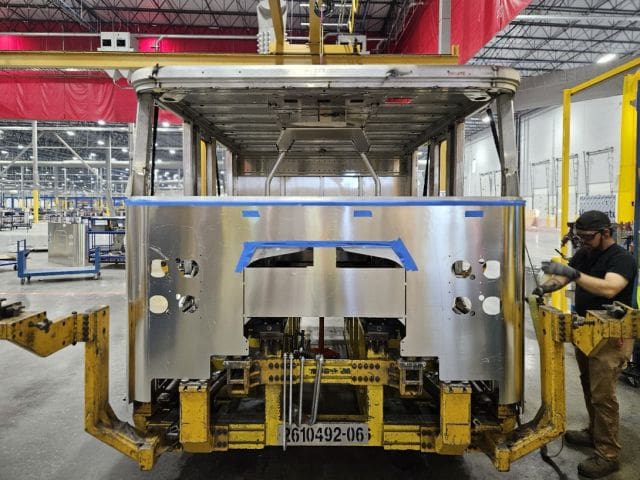

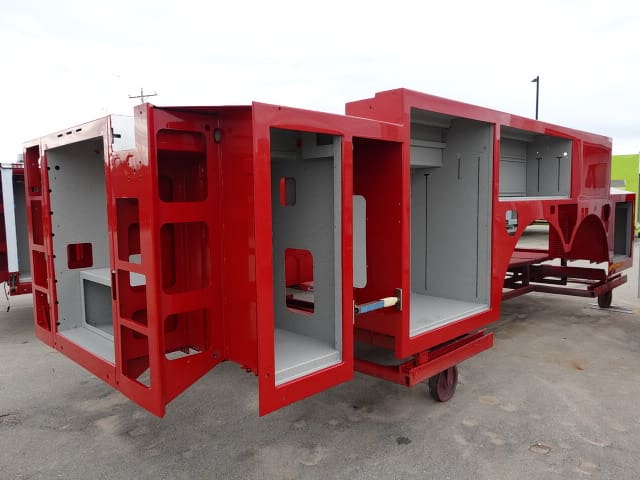

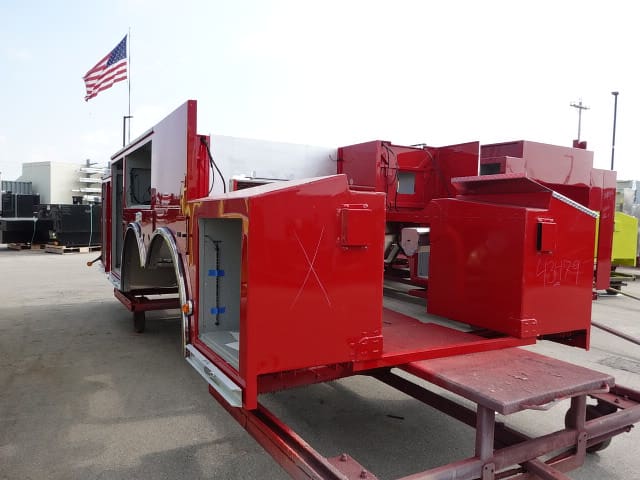

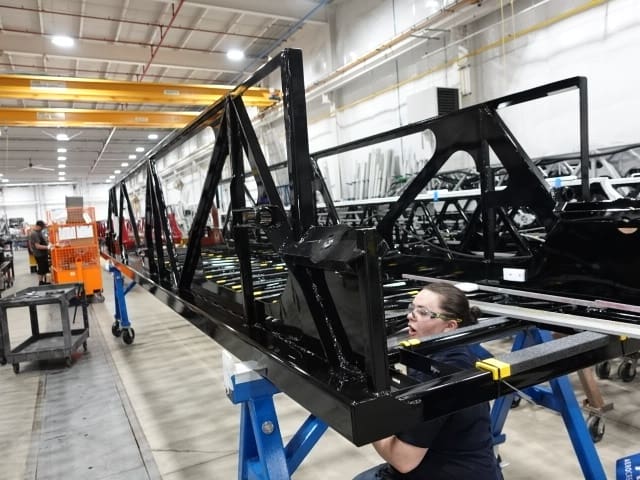

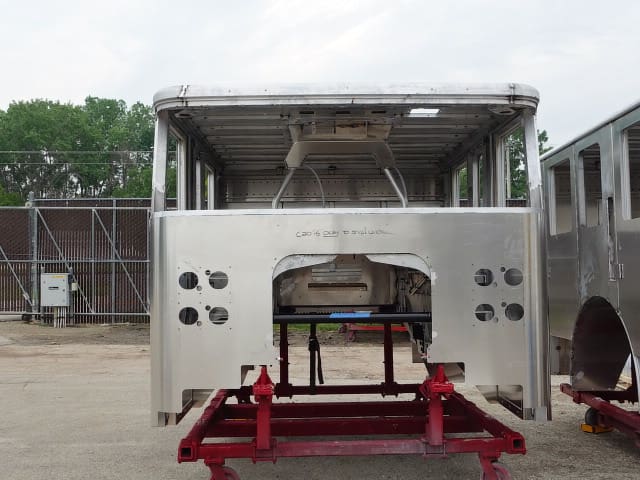

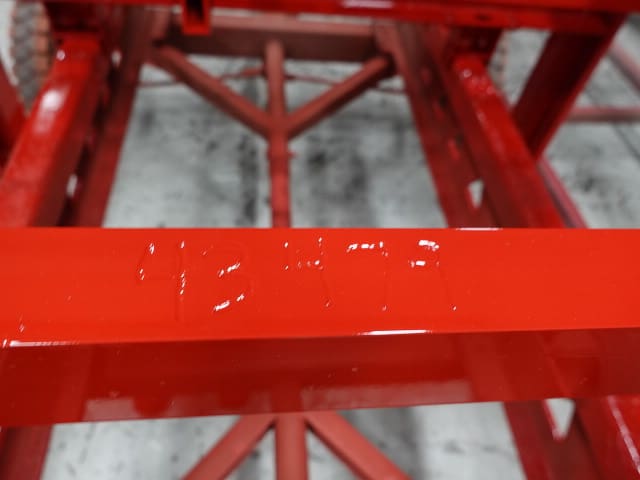

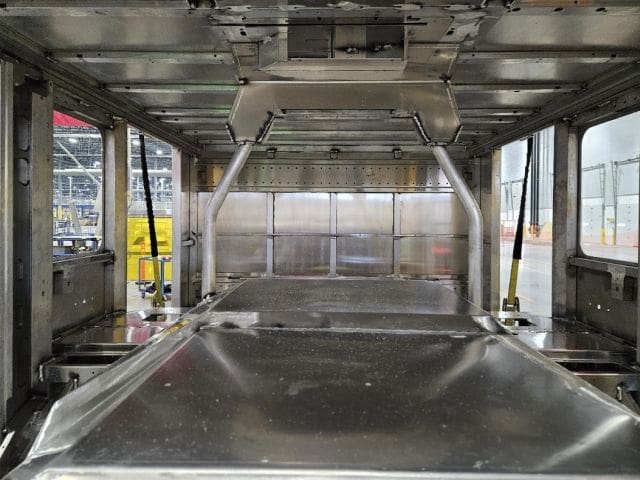

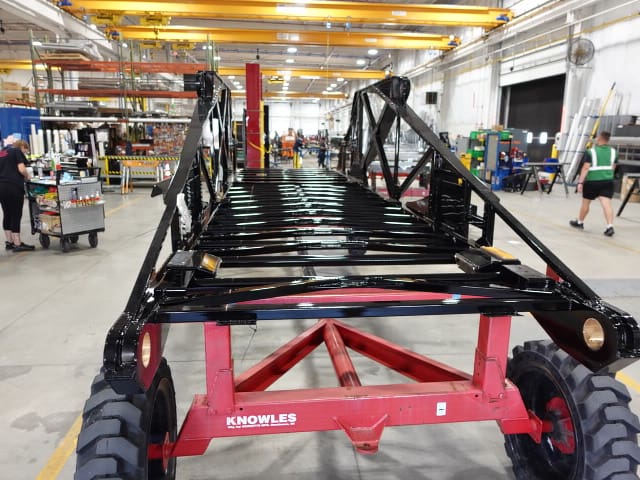

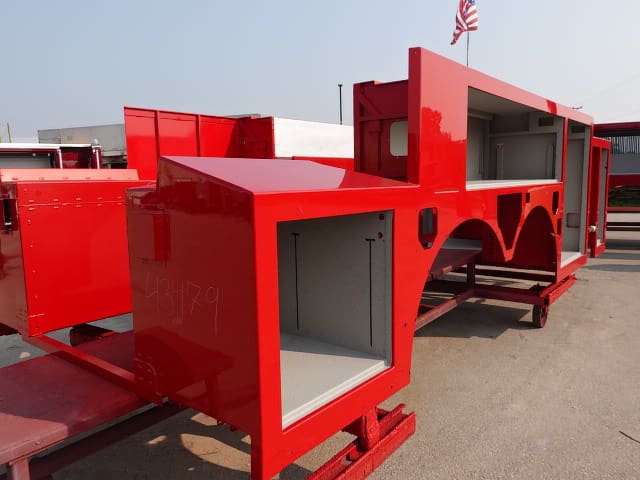

In this report, the body completed initial assembly and was merged with the chassis followed by the start of final assembly, the turntable module completed initial assembly, and the aerial device arrived and began initial assembly.
08-08-25

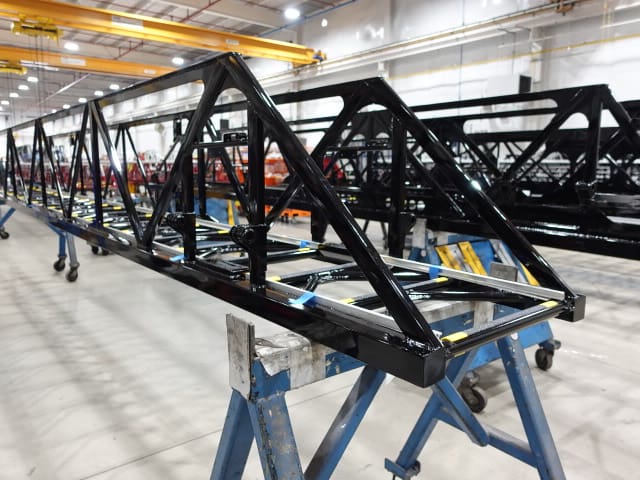

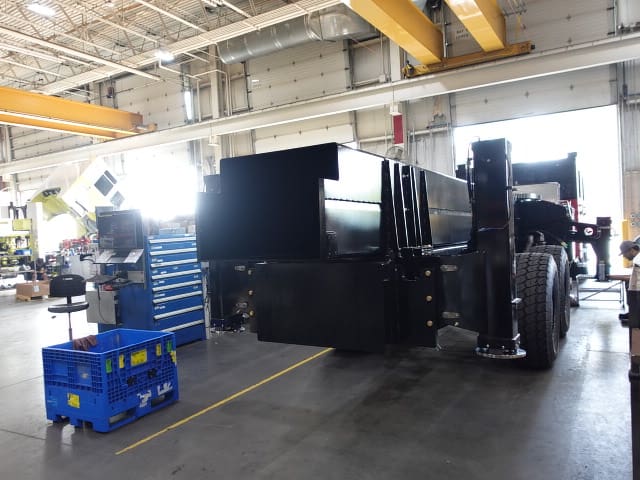

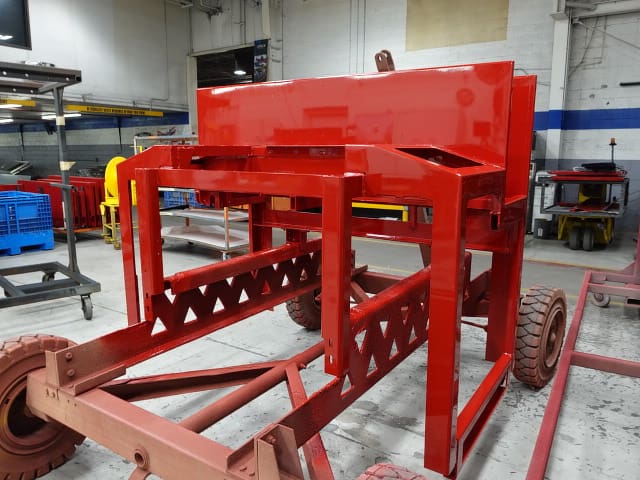

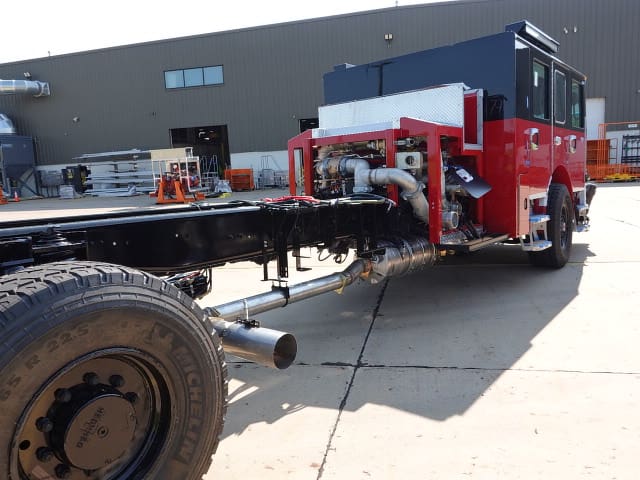

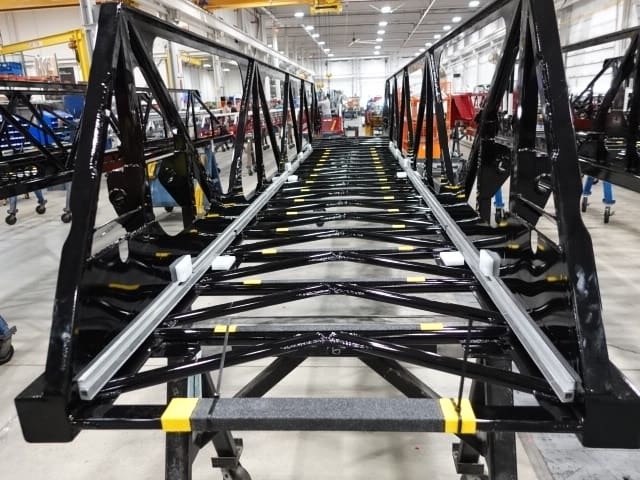

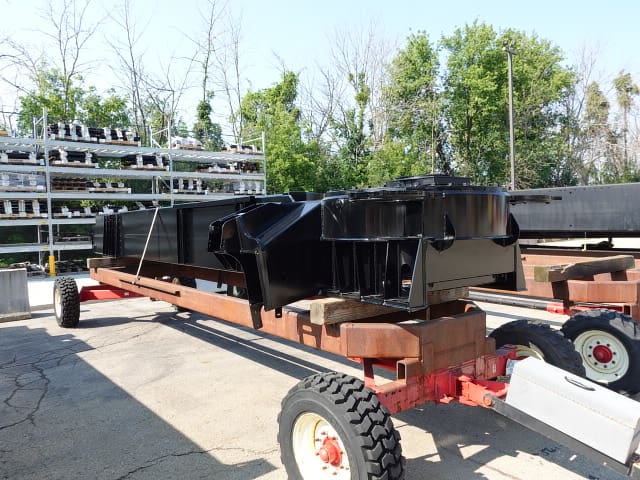

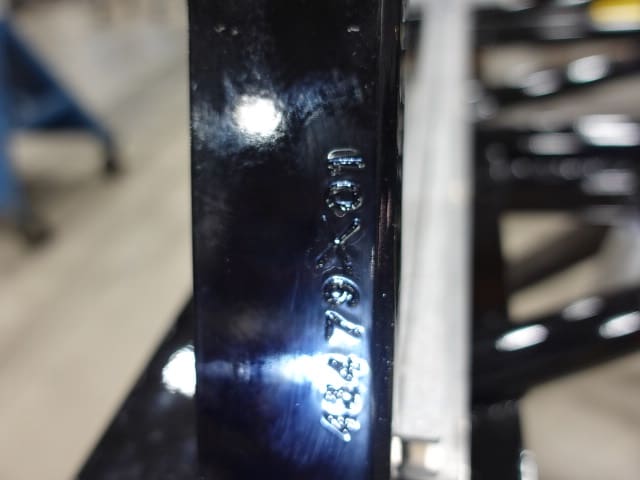

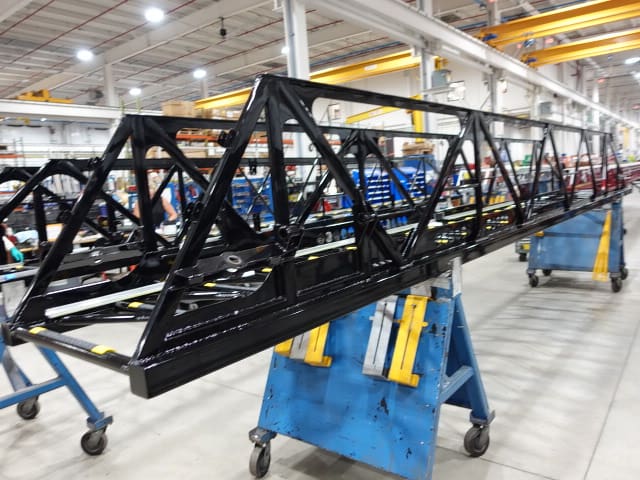

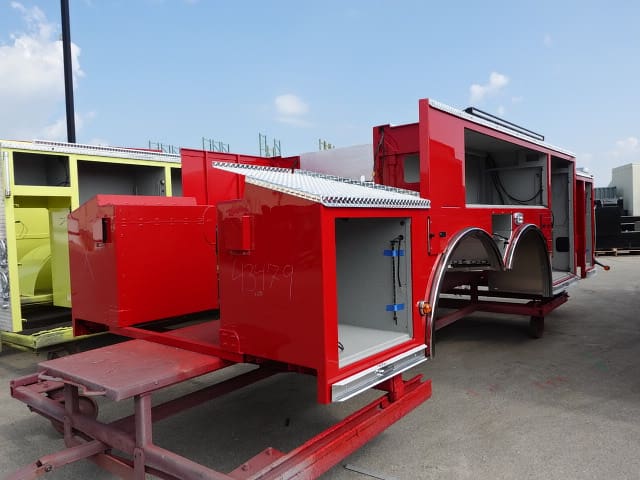

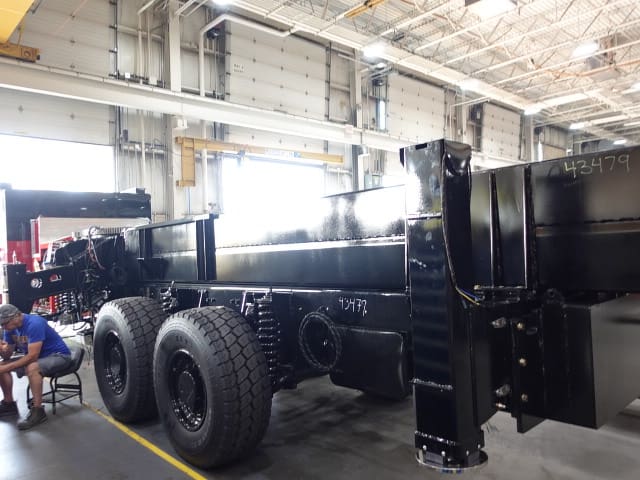

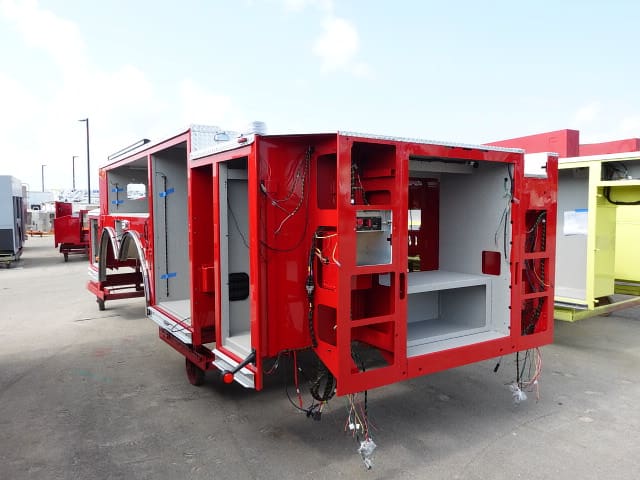

In this report, the torque box completed initial assembly and was merged with the chassis, the turntable module completed the paint process, and the body remained staged.

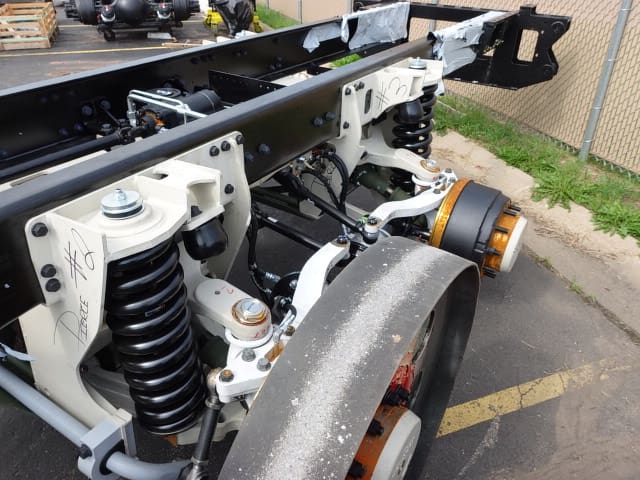

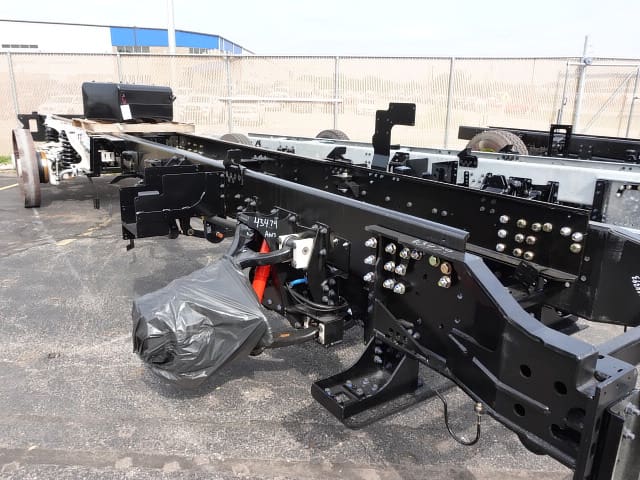

08-01-25

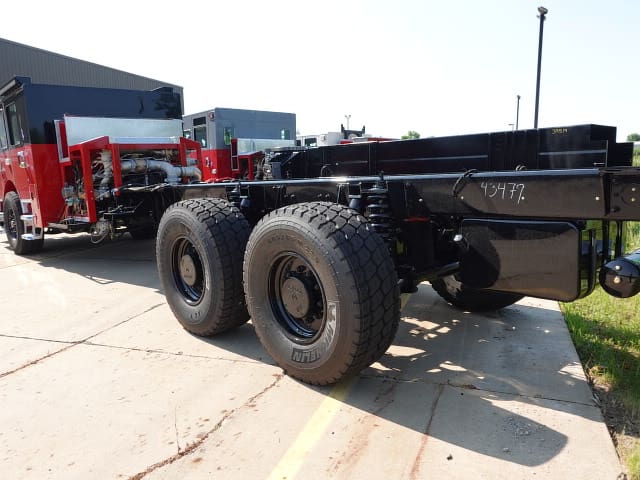

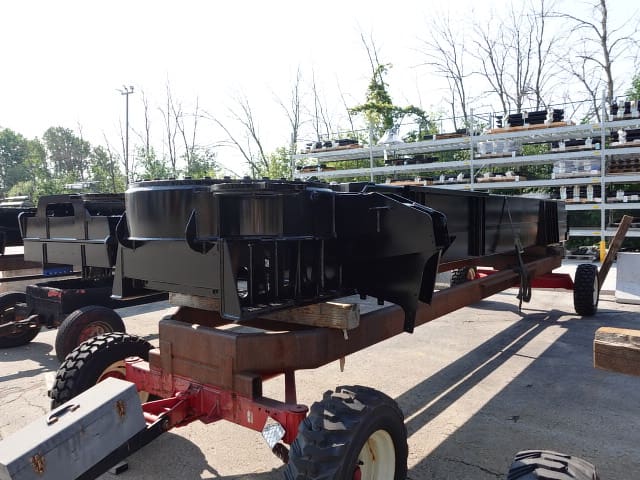

In this report, the cab and pump house were merged with the frame, the torque box arrived and was staged, the turntable module was unavailable for photos, and the body remained staged.
07-25-25

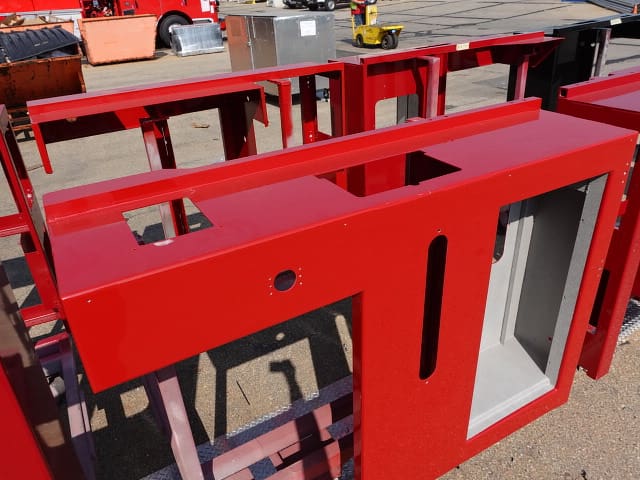

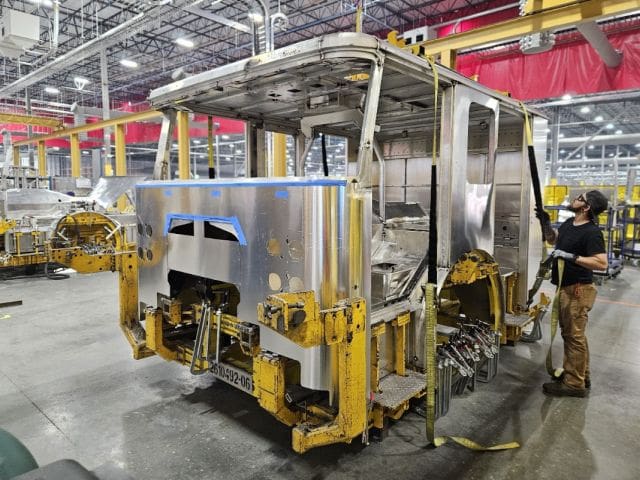

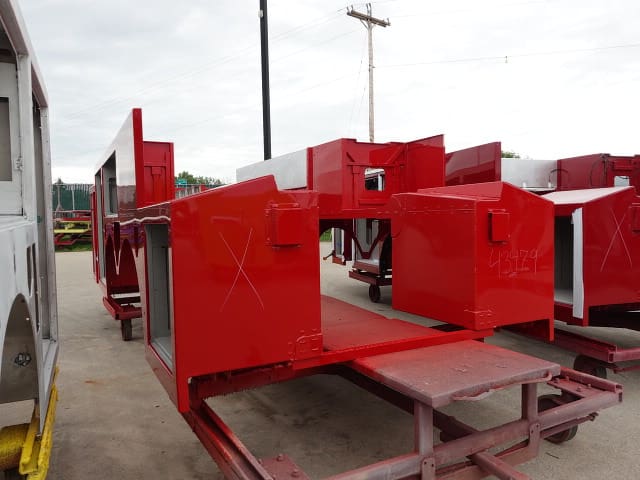

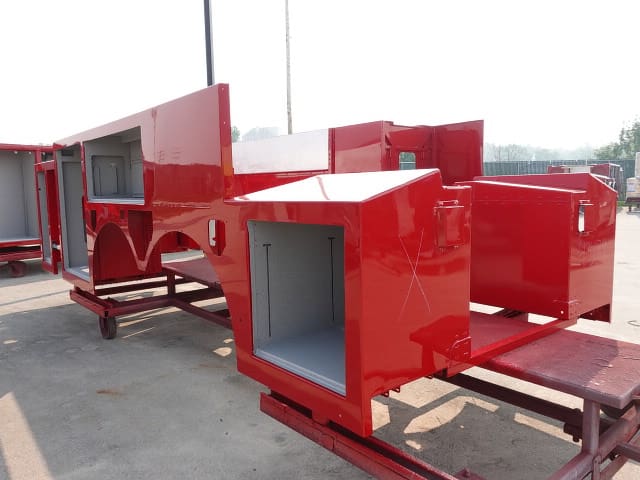

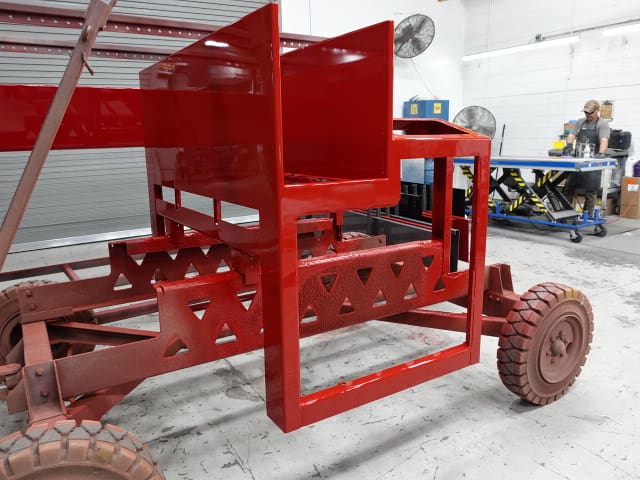

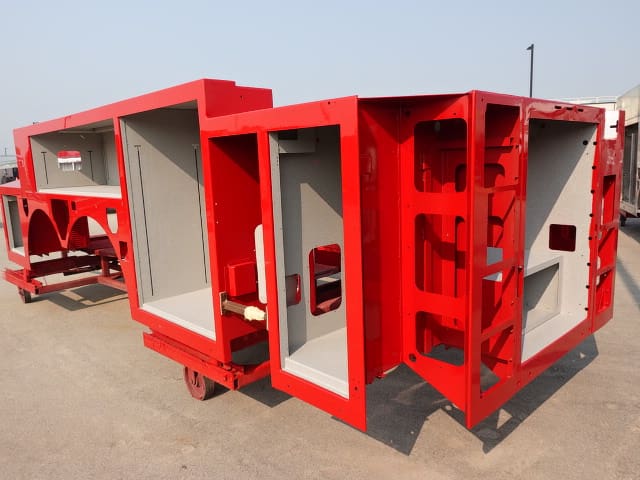

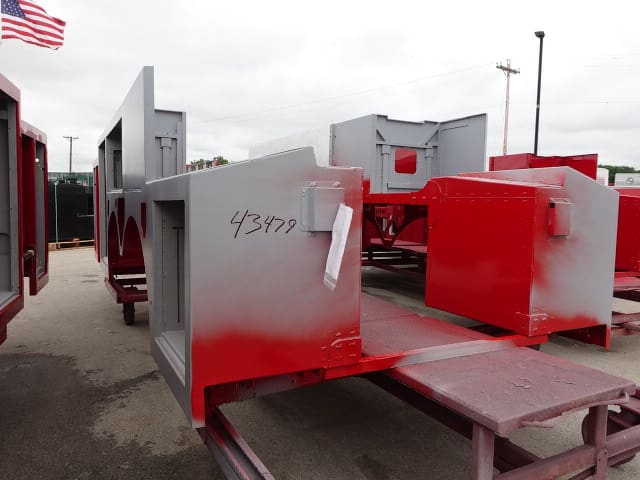

In this report, the cab completed initial assembly, the frame build continued, the turntable module was unavailable for photos, the pump house structure was fabricated then painted, and the body completed the paint process.
07-18-25

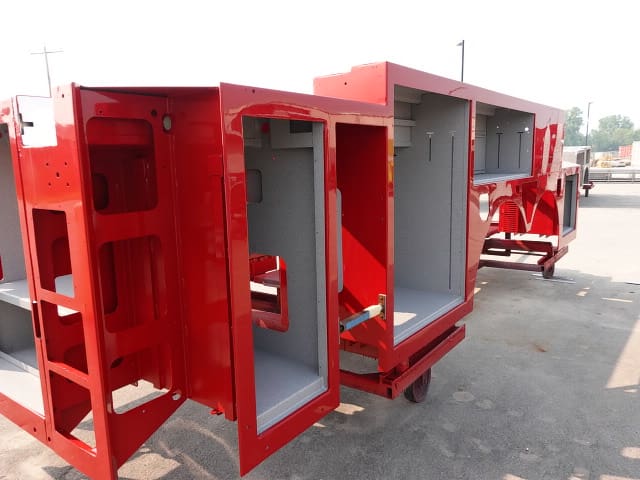

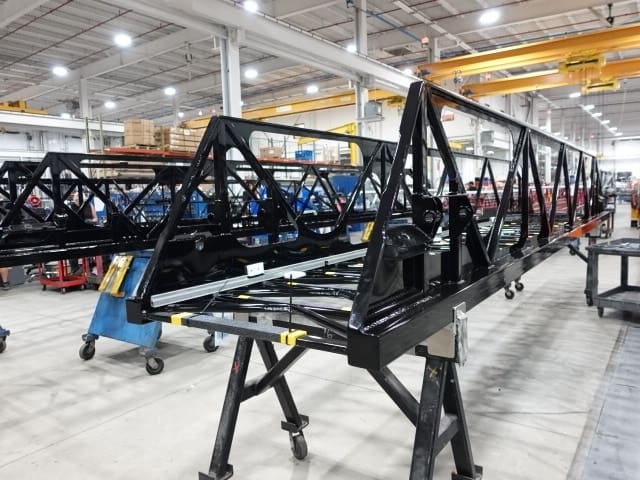

In this report, the cab continued initial assembly, the frame build continued, the turntable module was fabricated, and the body continued through paint.

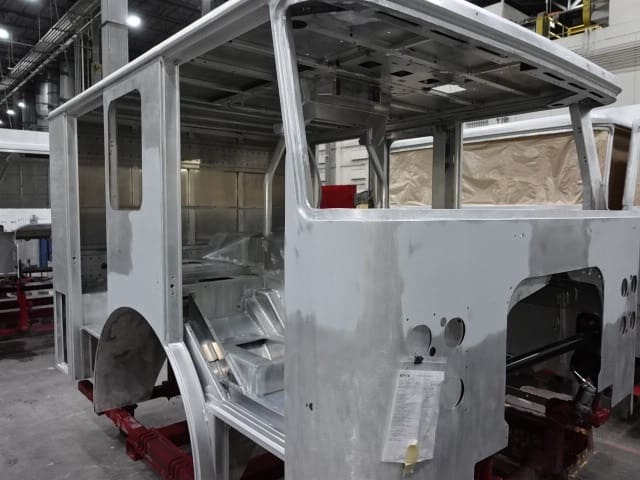

07-11-25

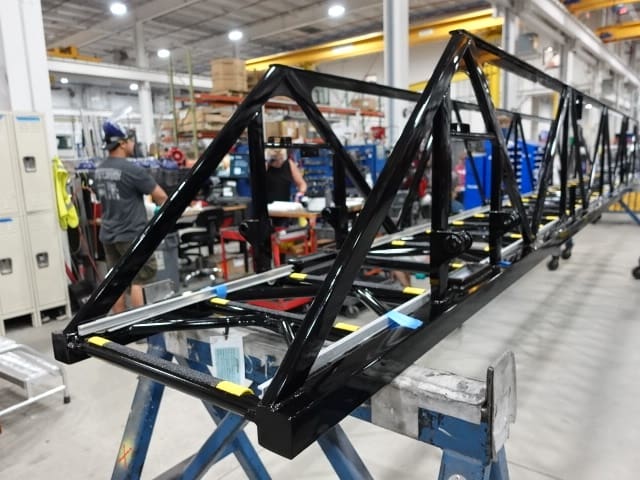

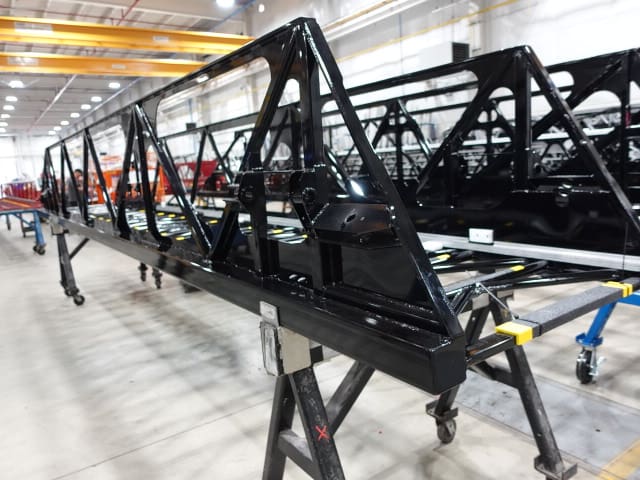

In this report, the cab completed paint and began initial assembly, the frame build began, and the body was fabricated and began the paint process in metal finishing.
06-06-25
This new Pierce apparatus is now in production! In this report, the cab began fabrication.
