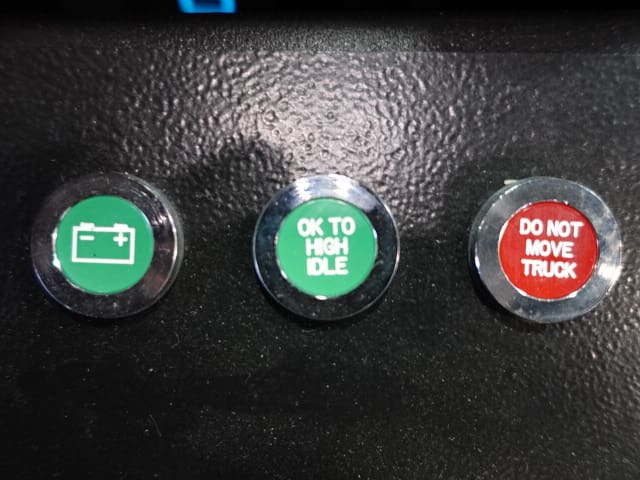

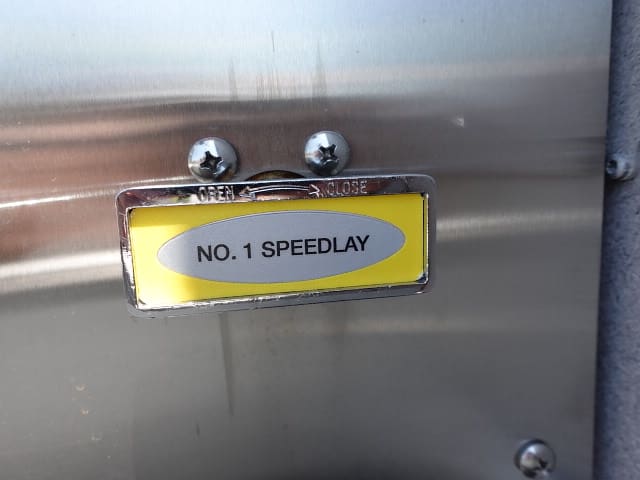

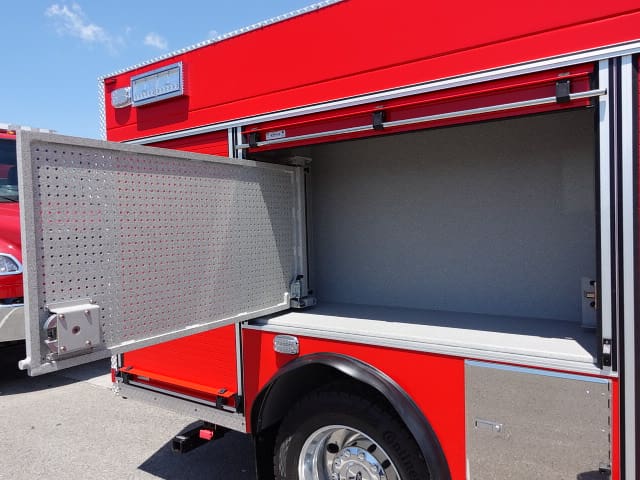

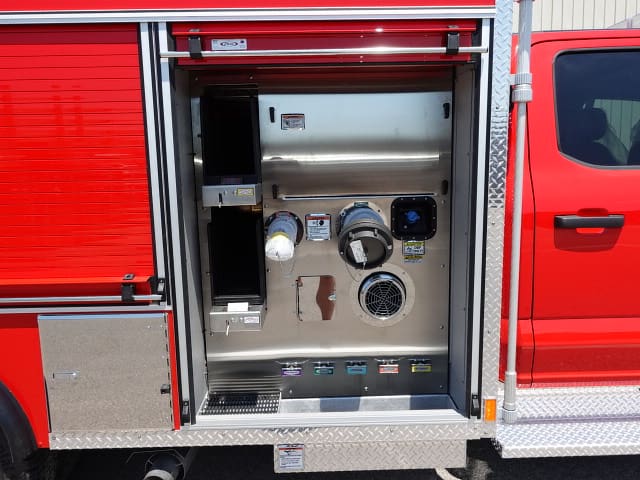

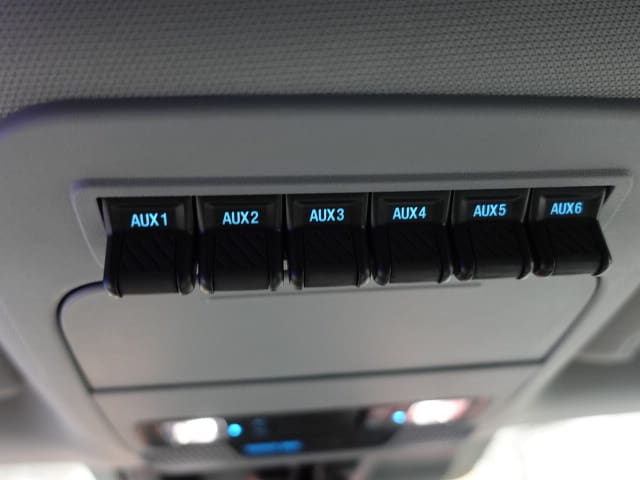

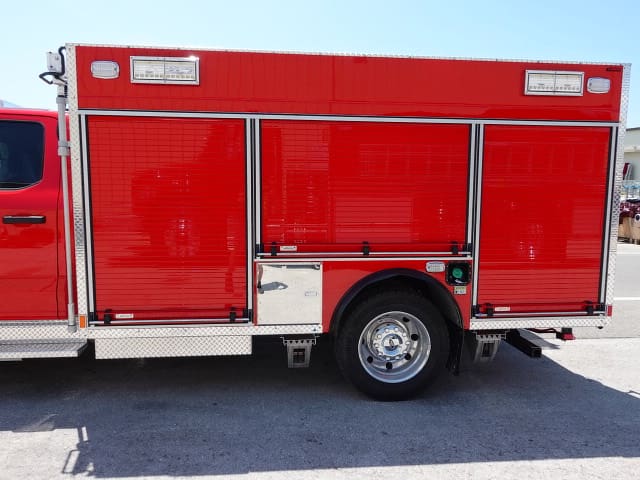

08-08-25

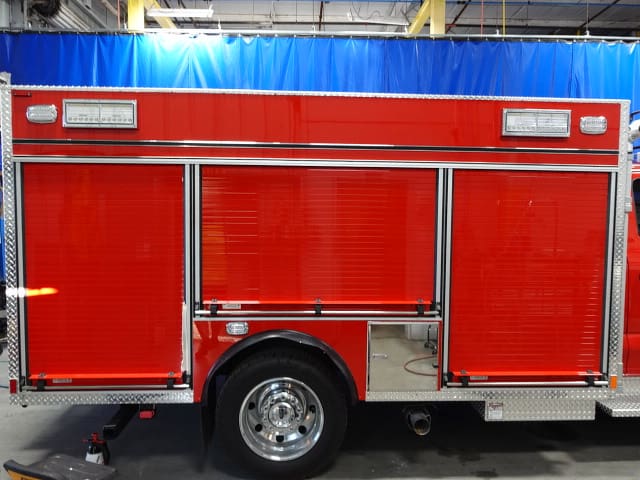

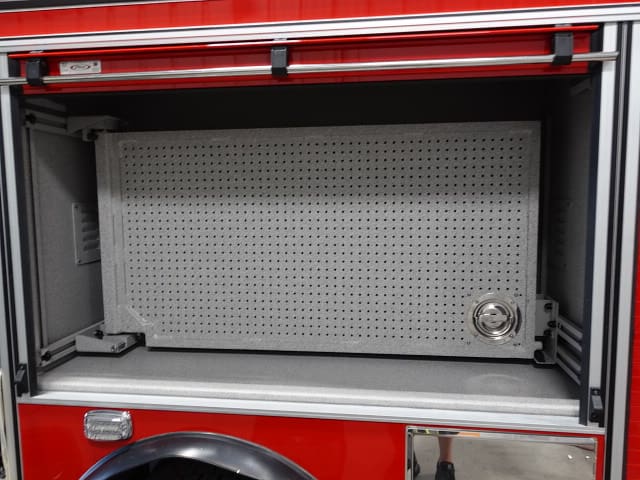

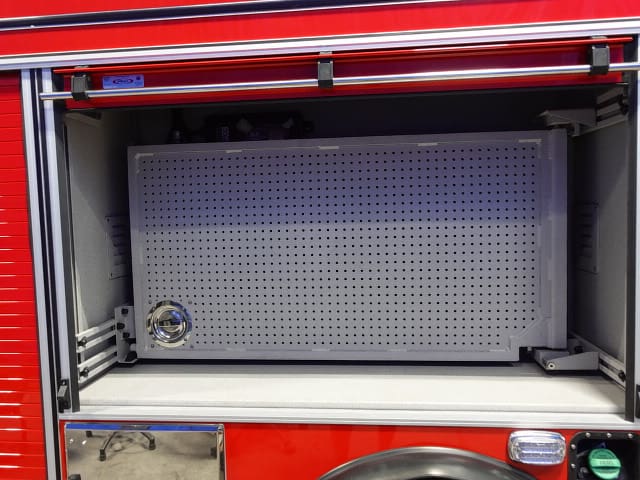

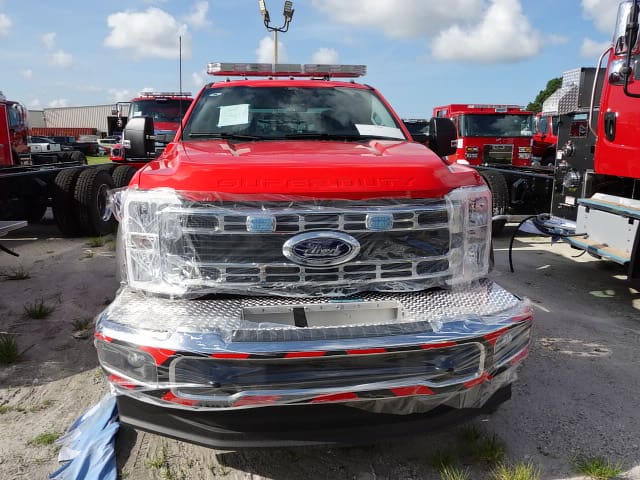

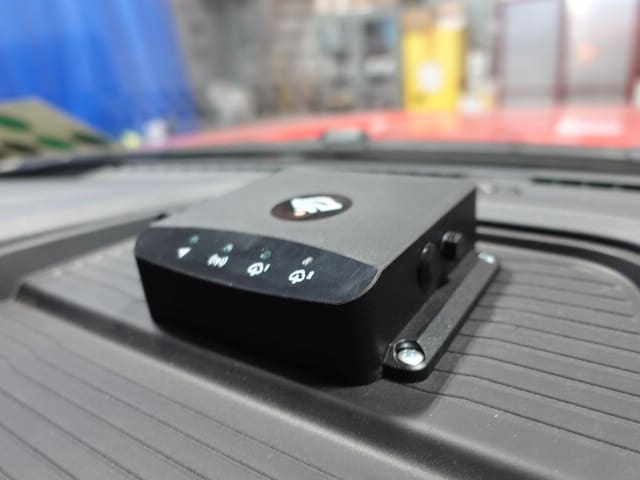

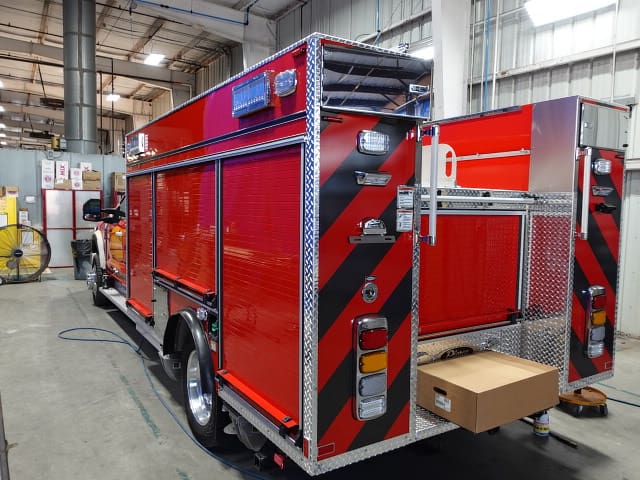

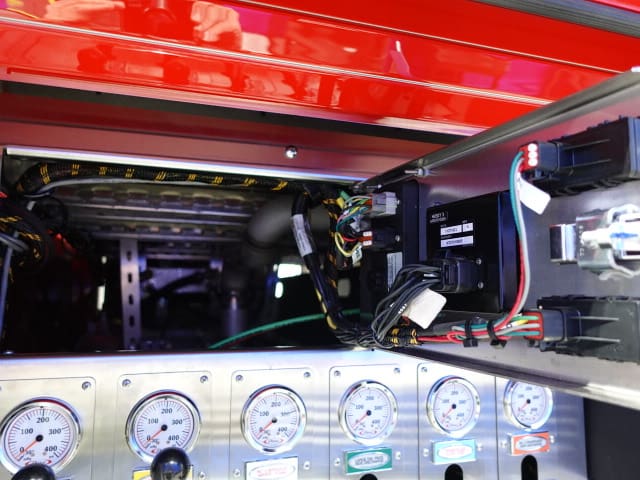

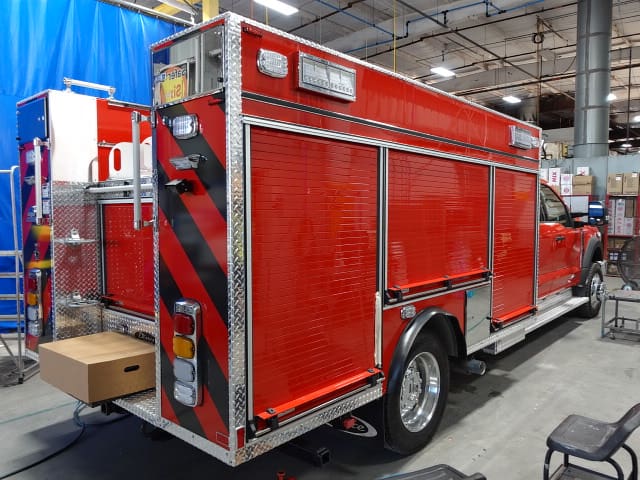

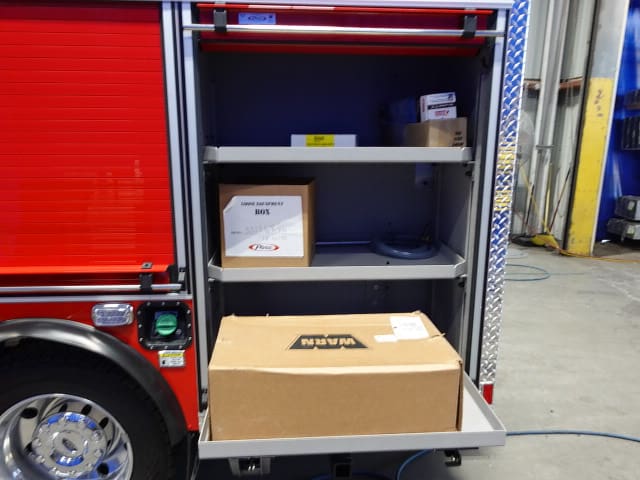

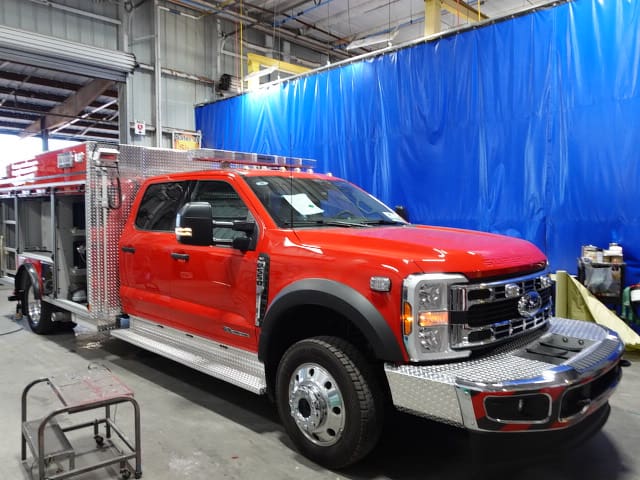

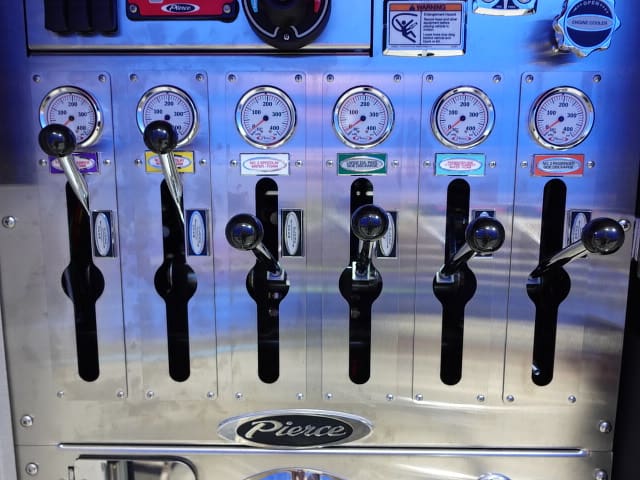

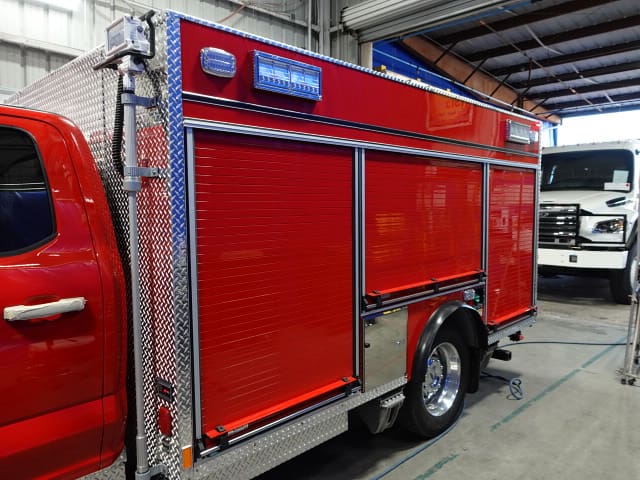

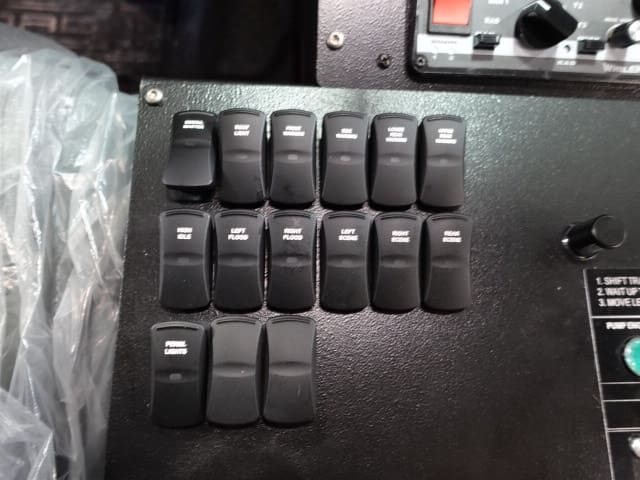

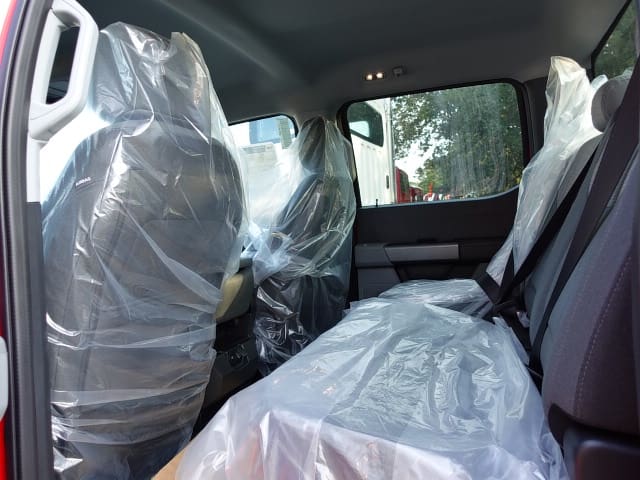

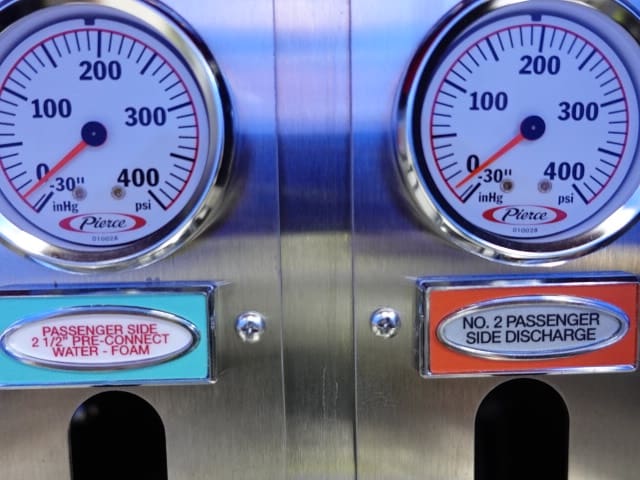

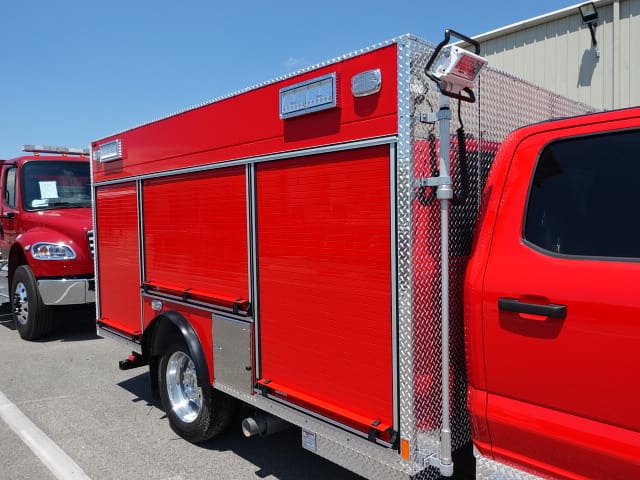

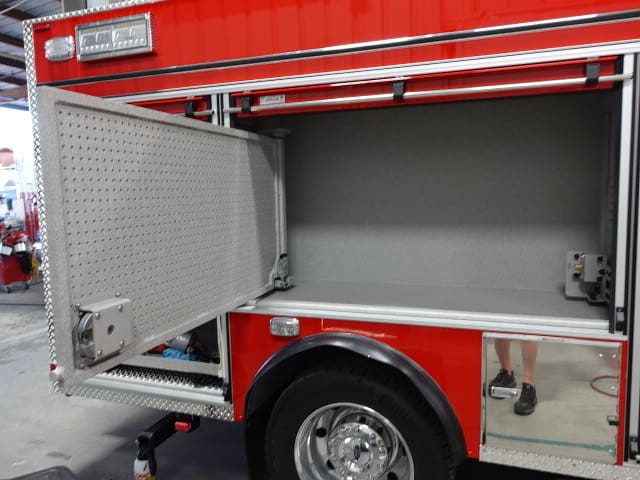

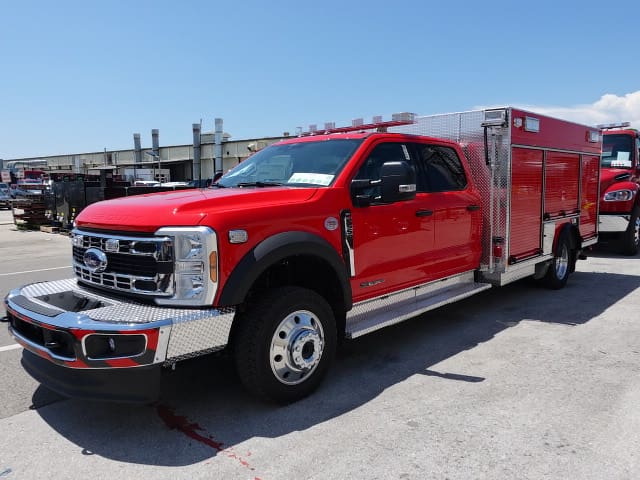

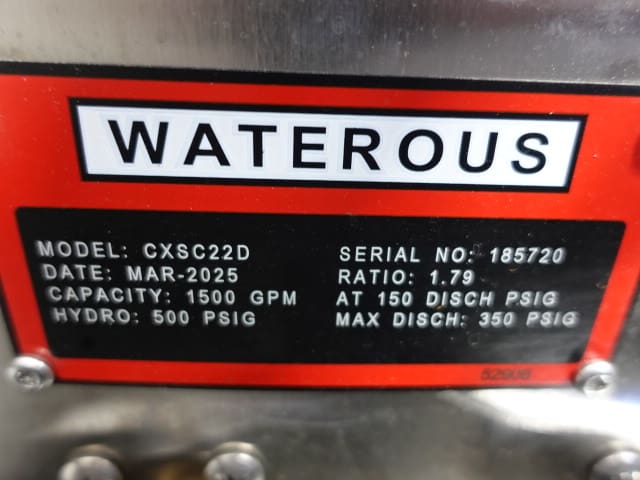

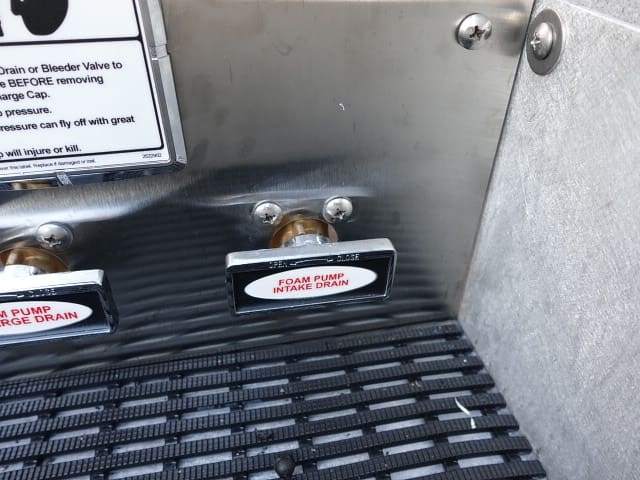

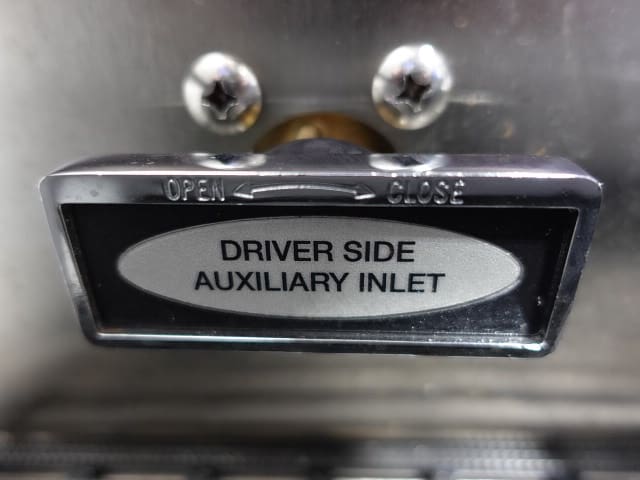

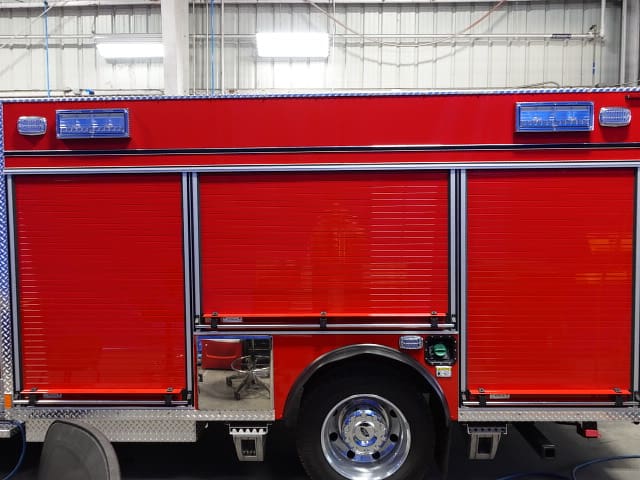

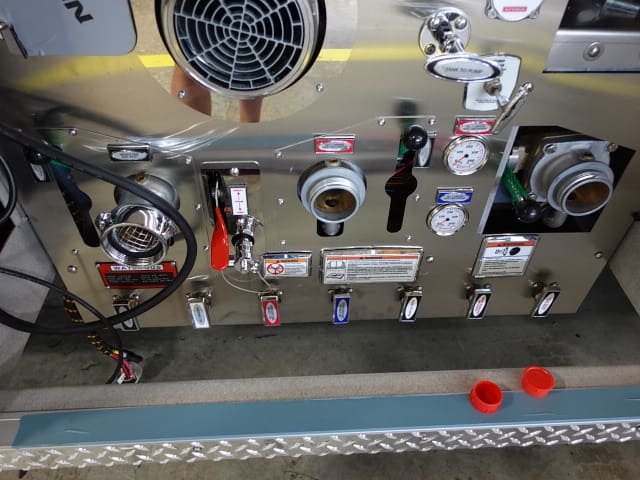

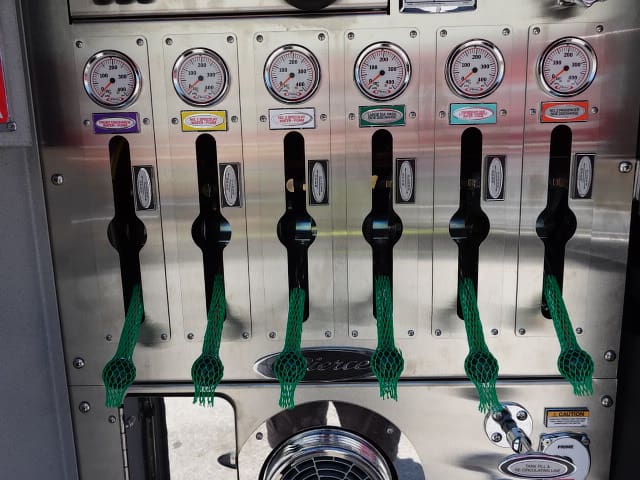

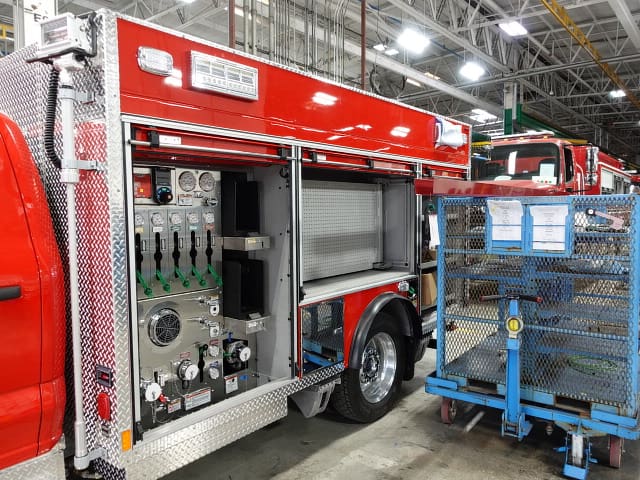

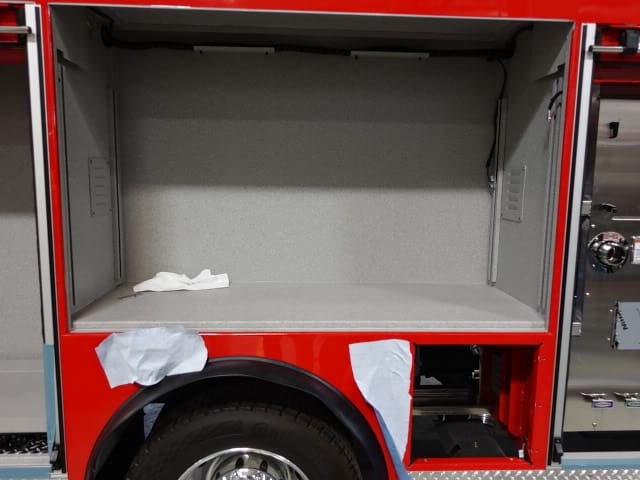

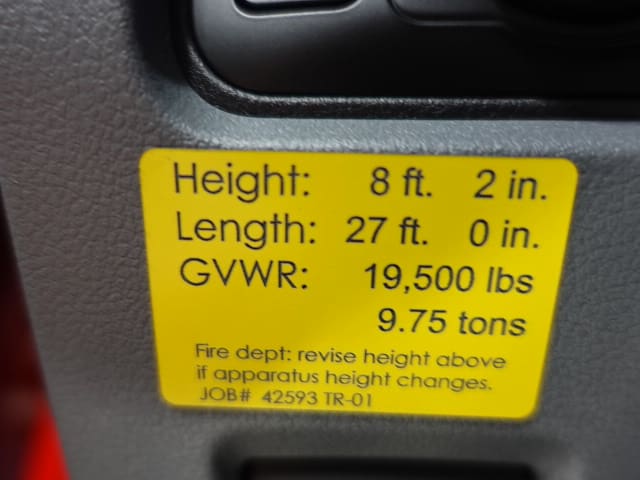

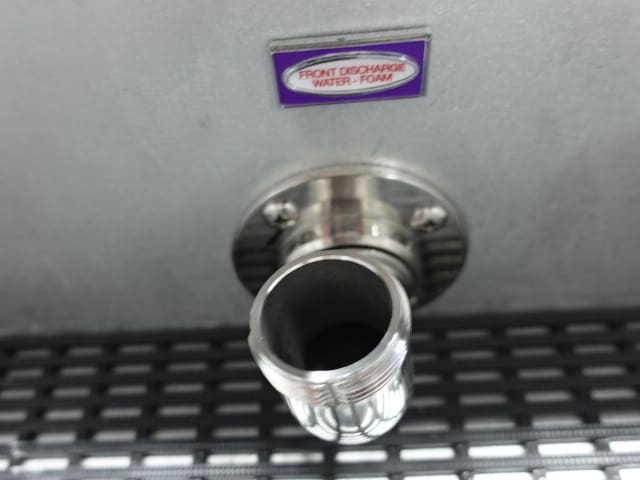

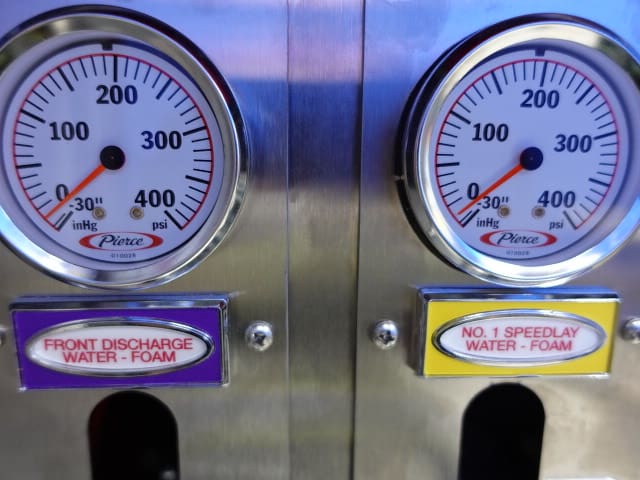

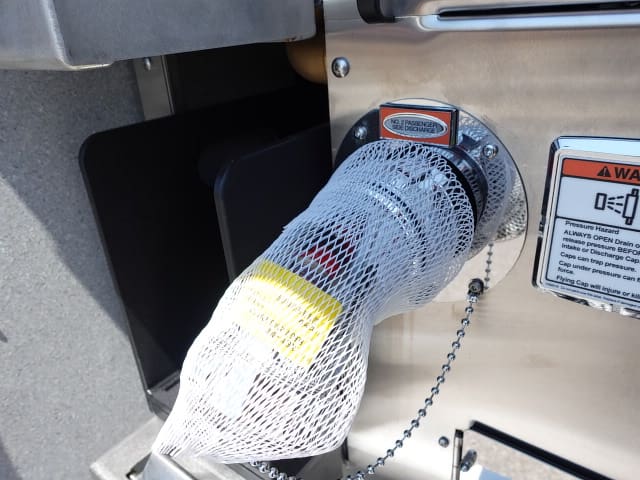

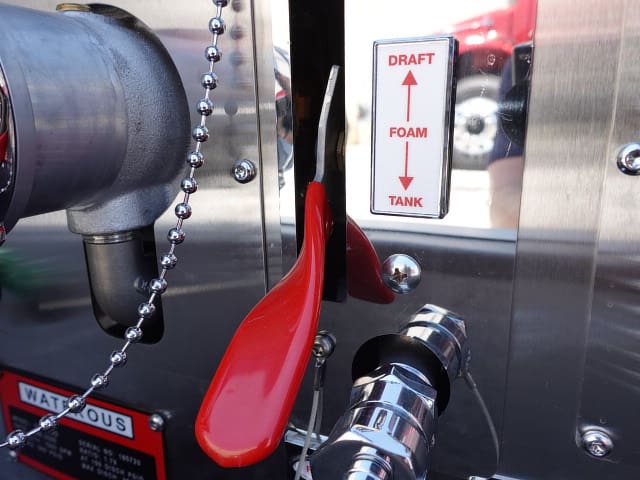

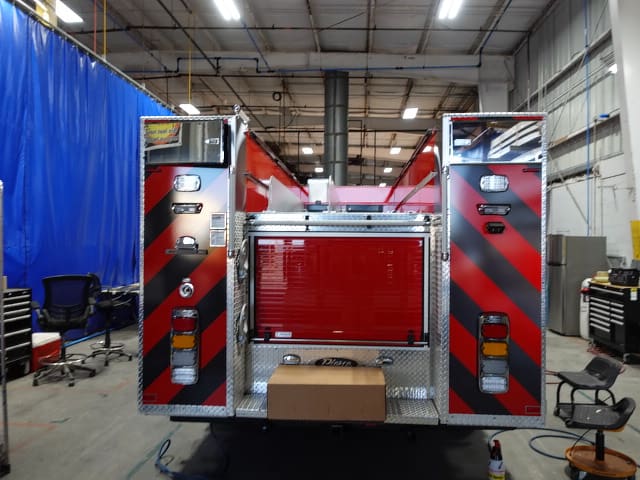

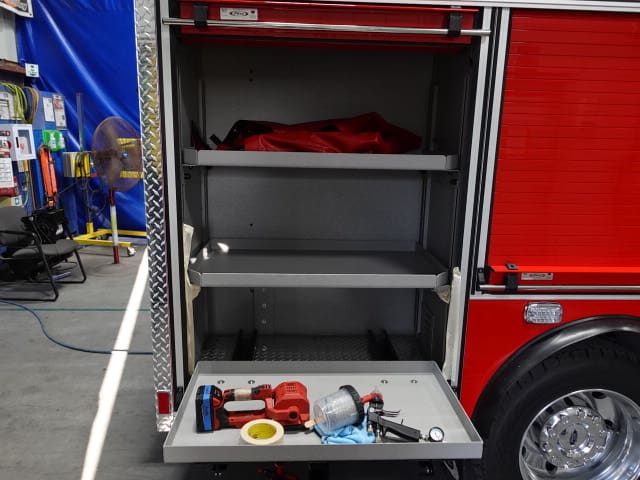

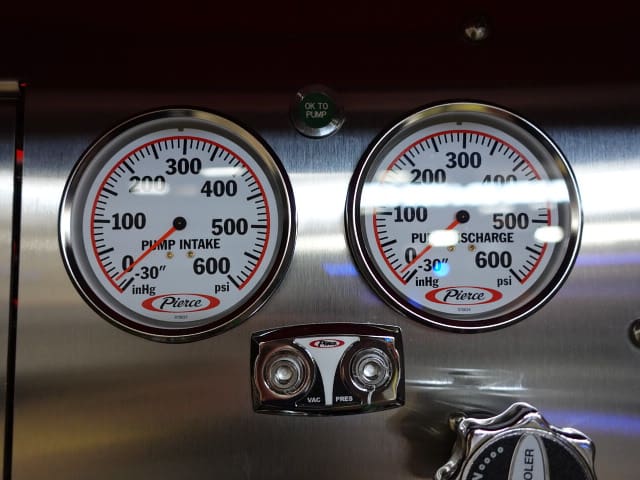

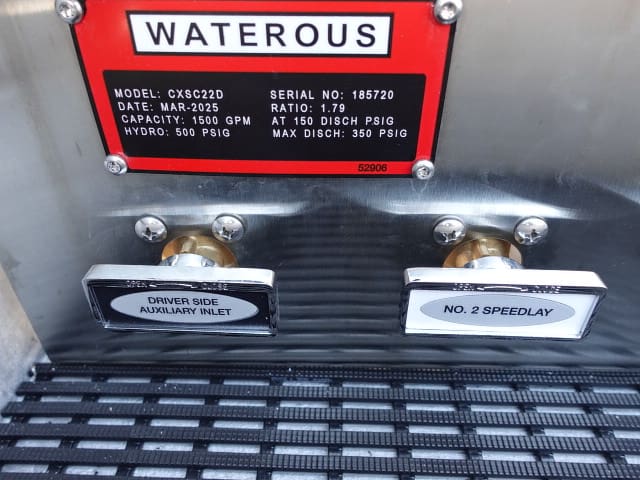

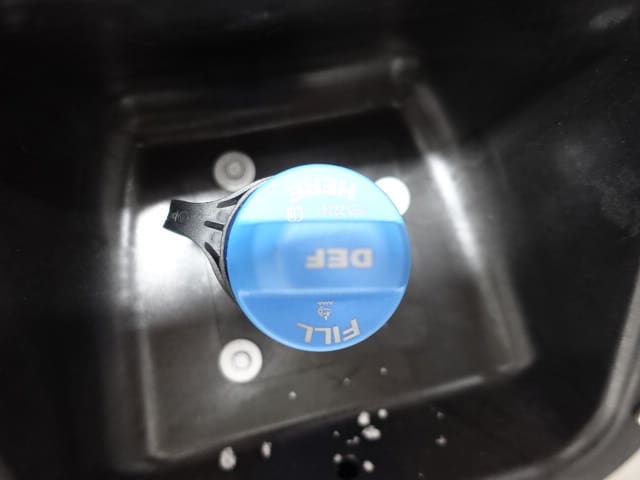

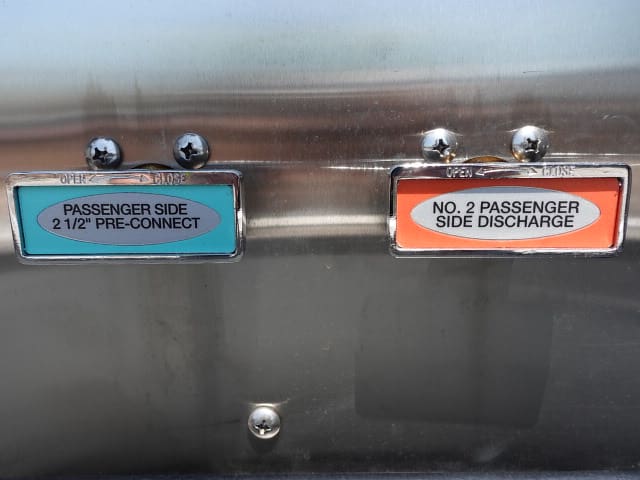

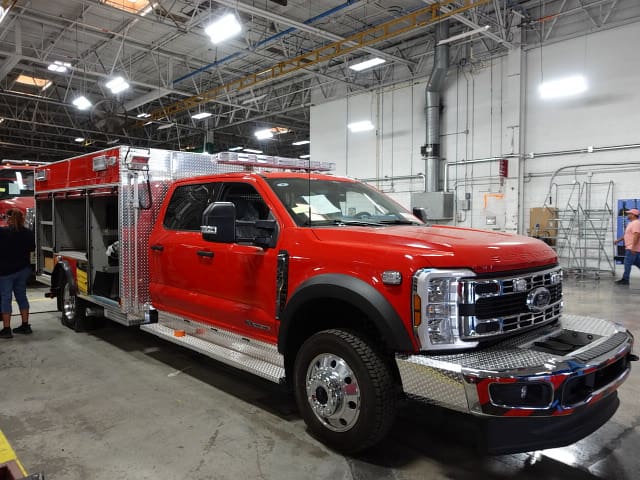

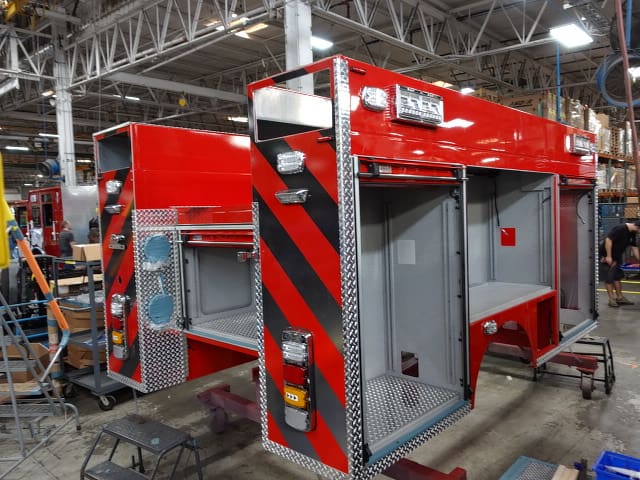

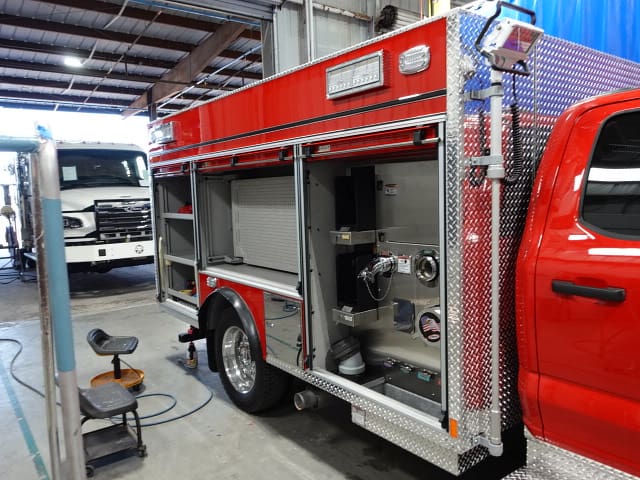

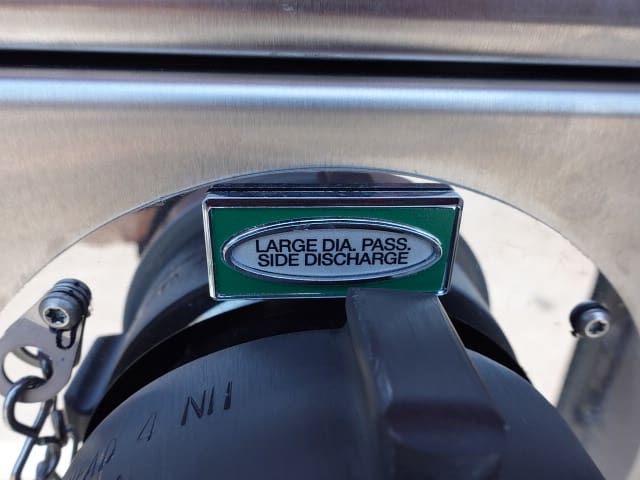

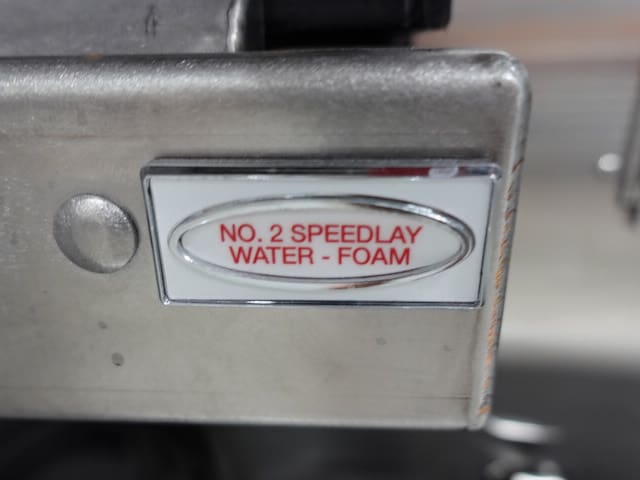

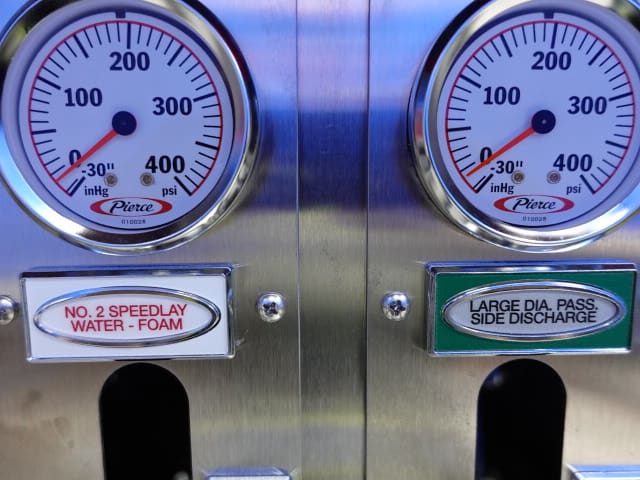

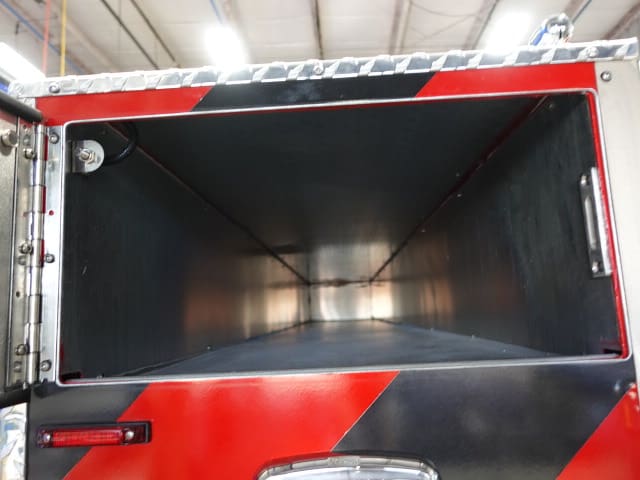

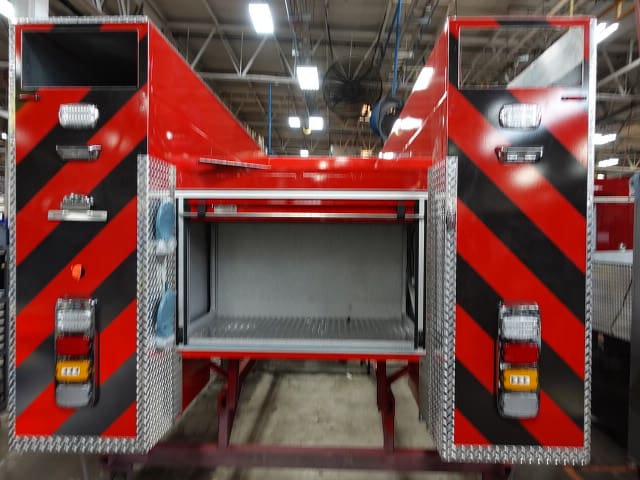

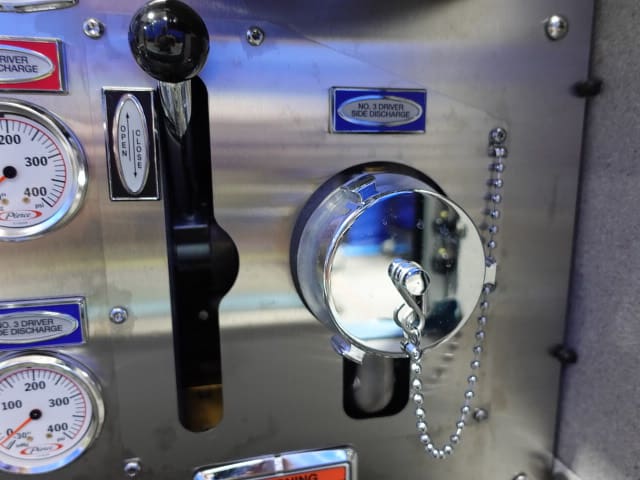

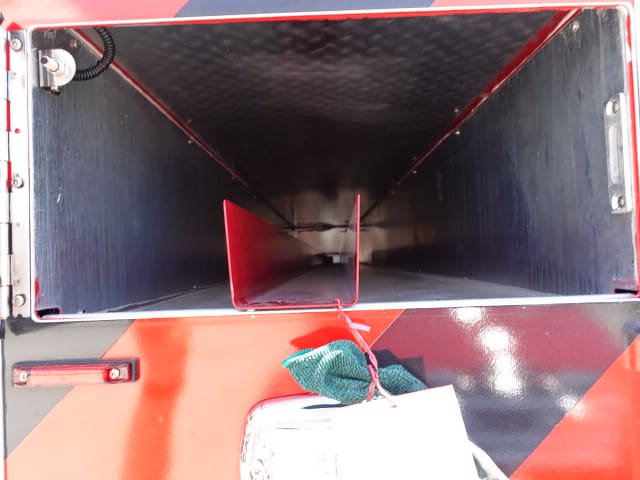

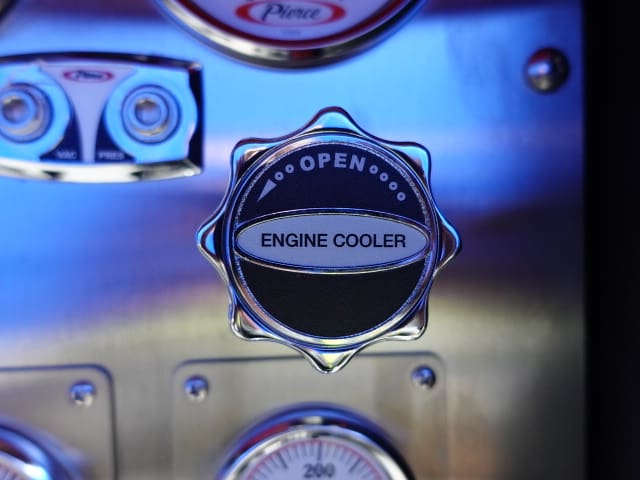

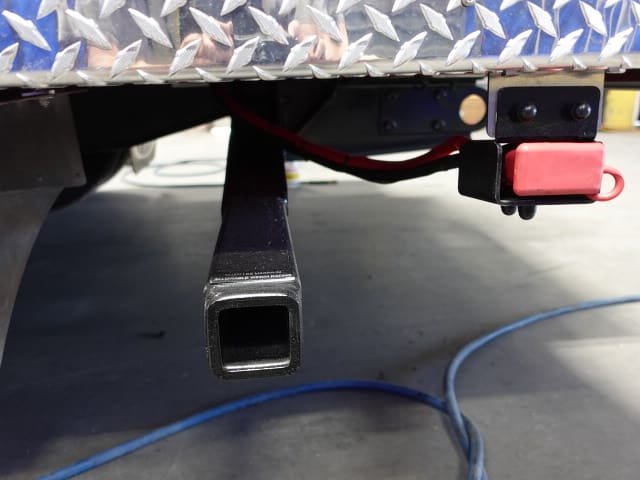

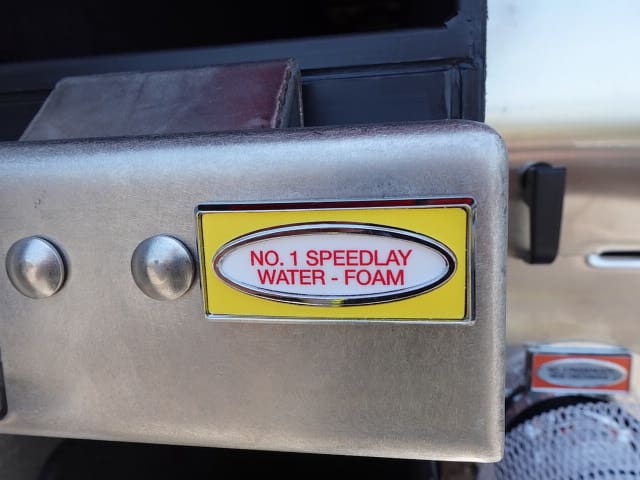

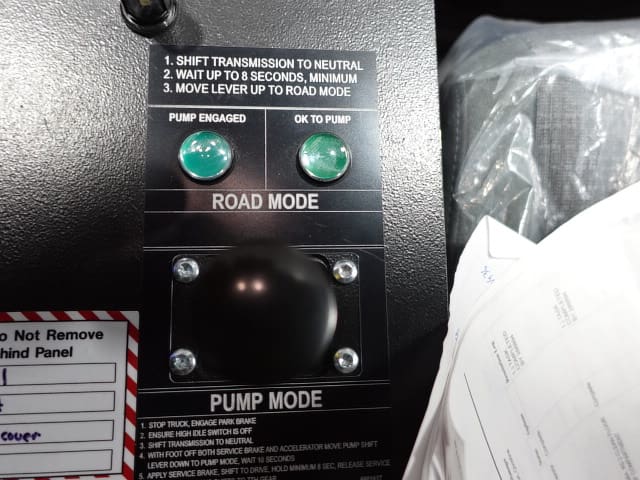

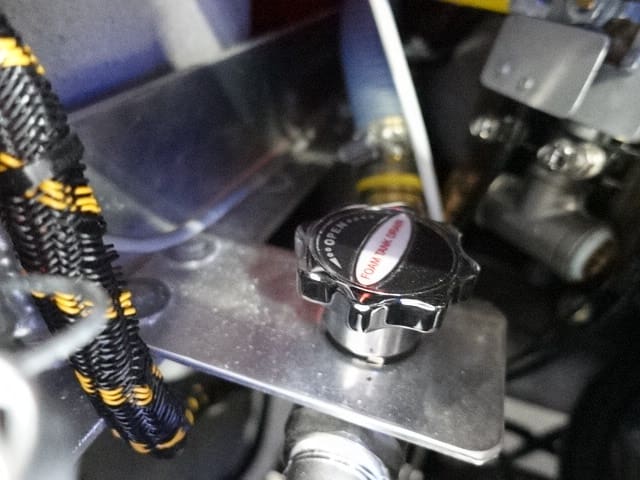

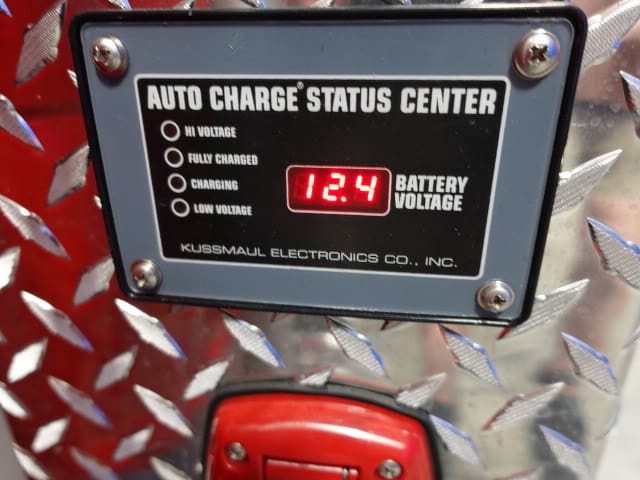

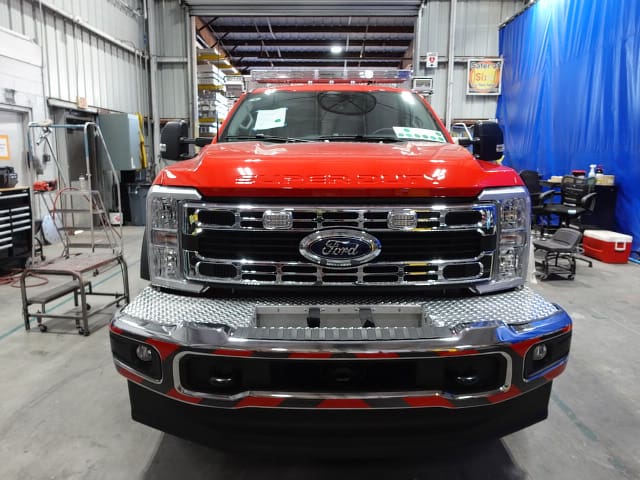

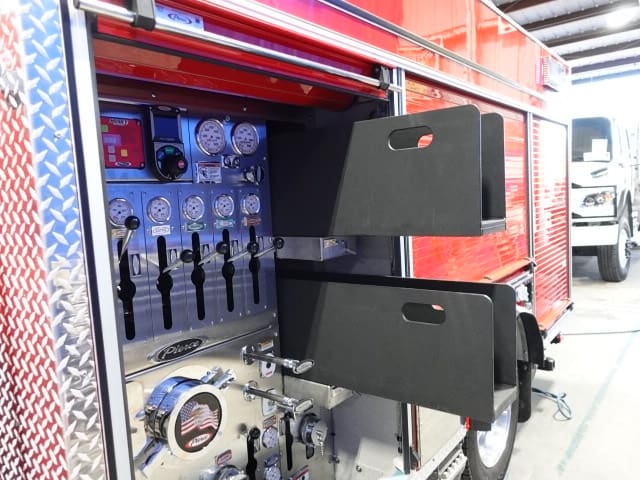

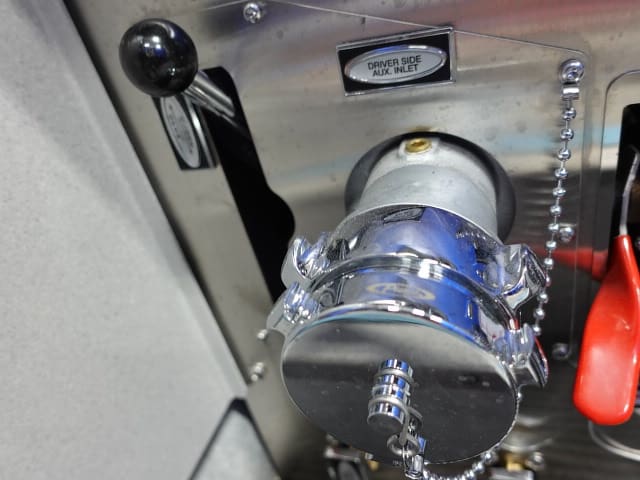

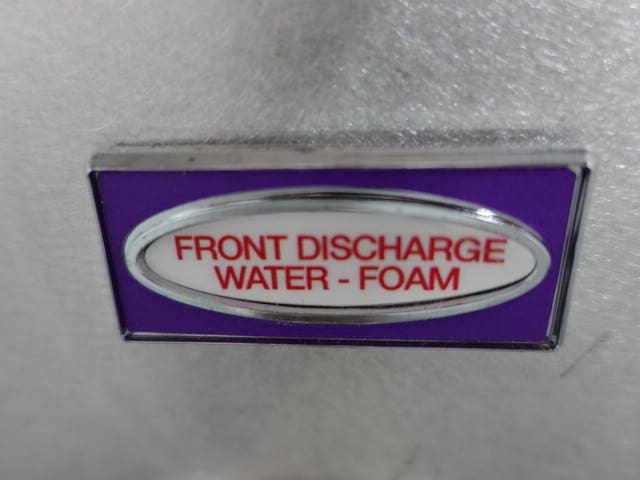

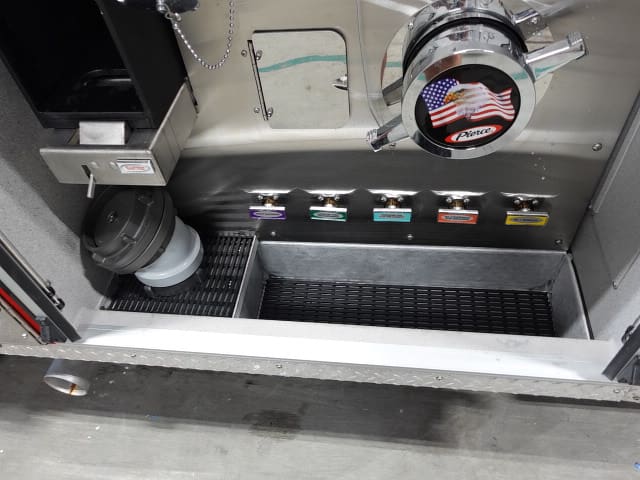

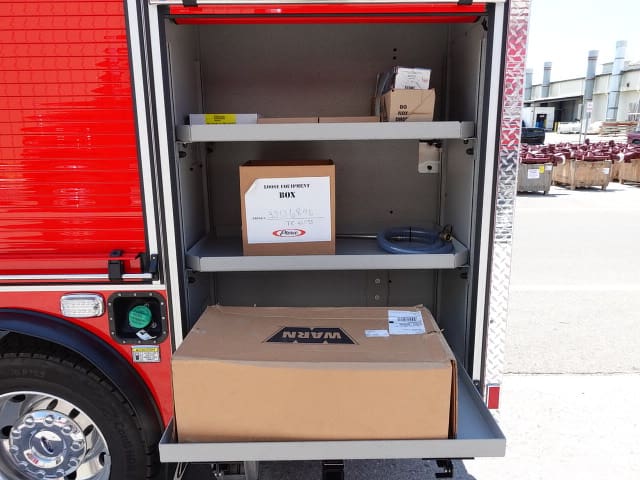

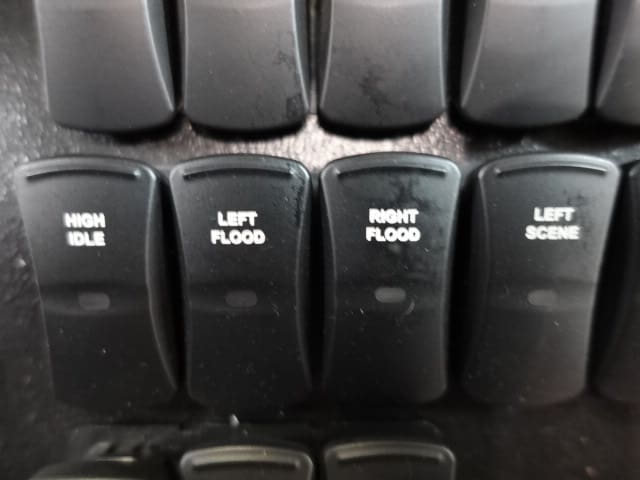

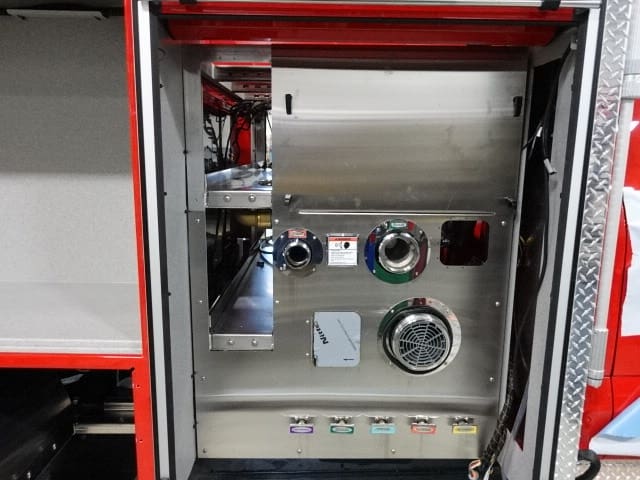

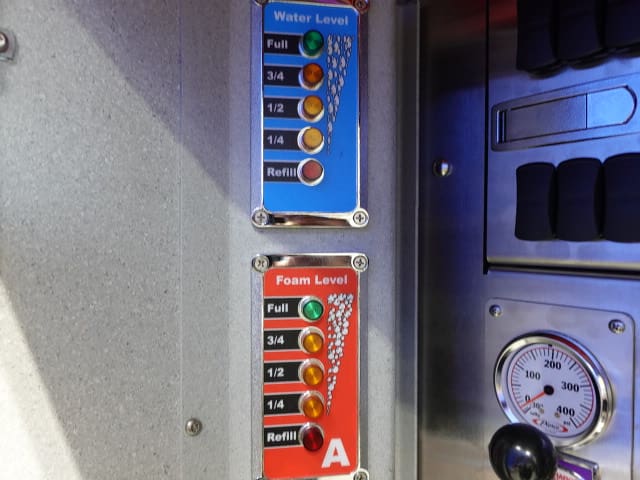

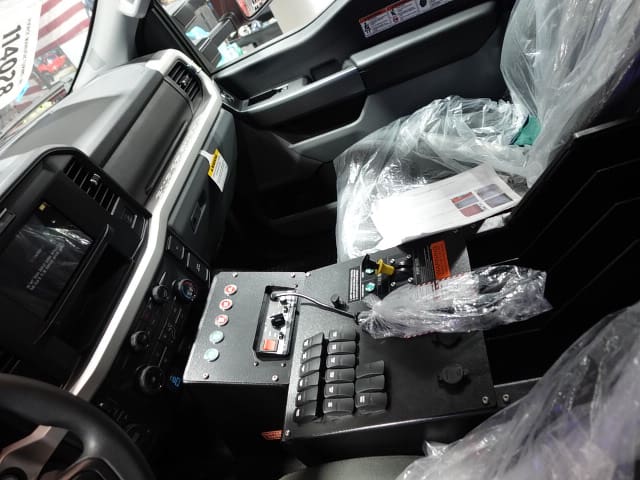

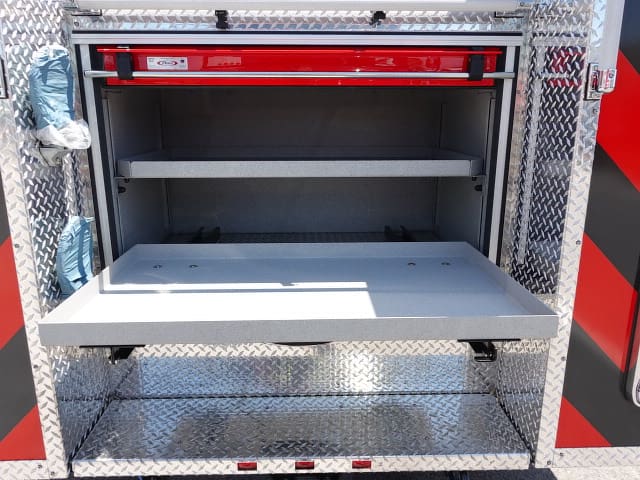

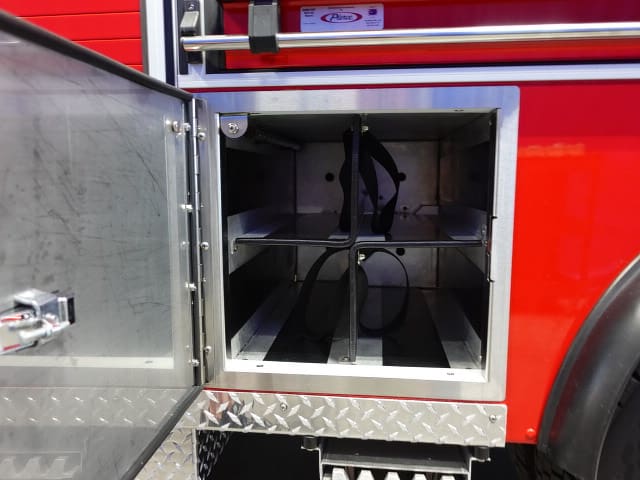

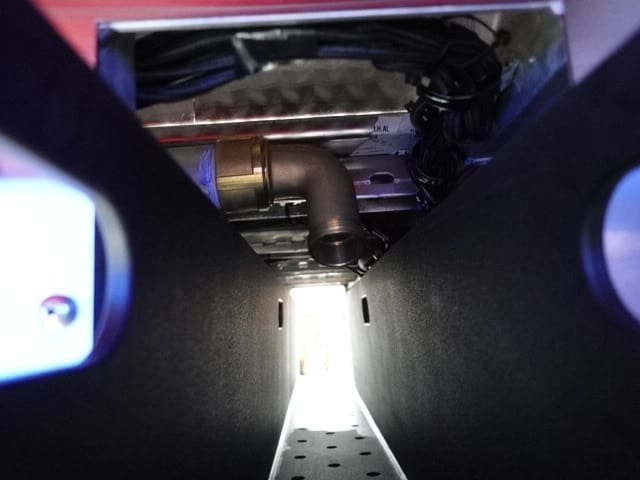

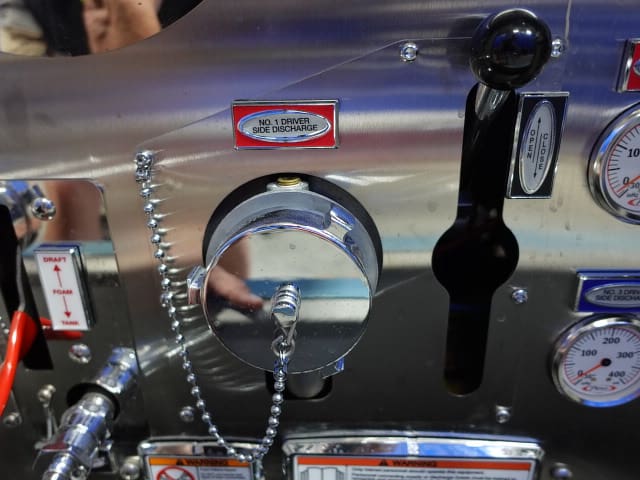

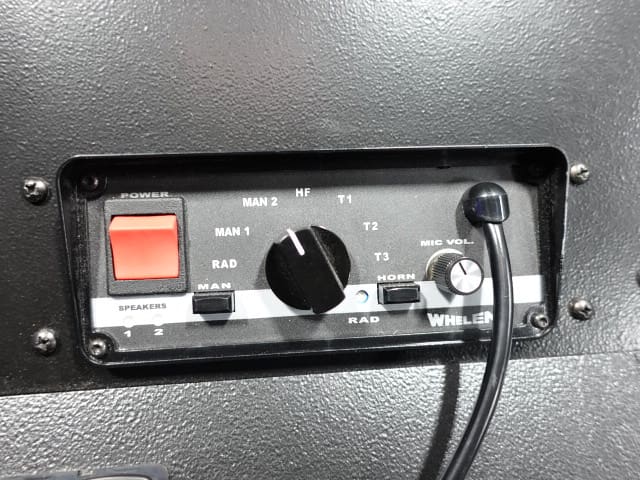

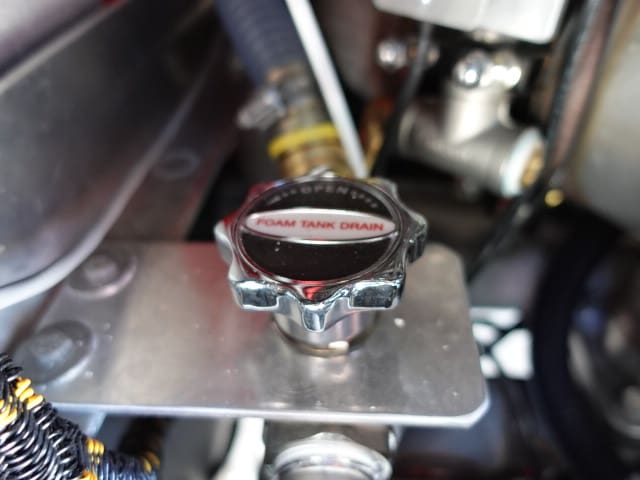

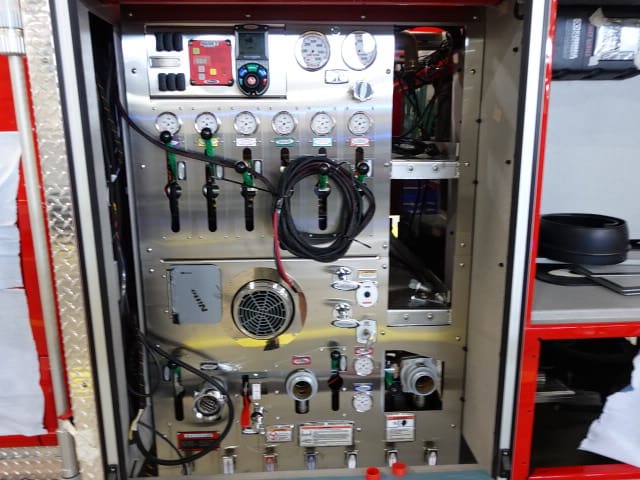

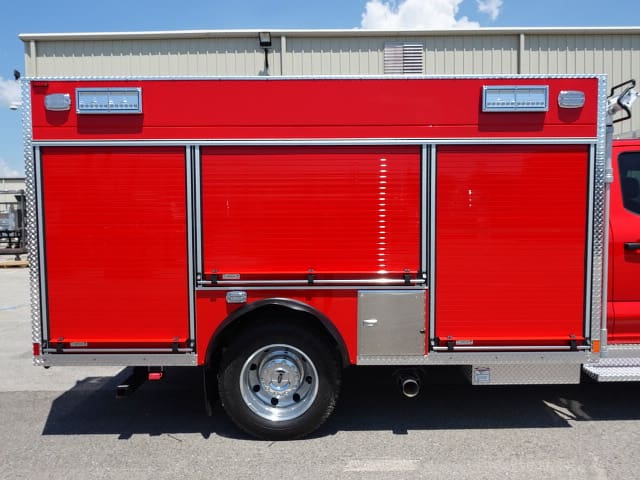

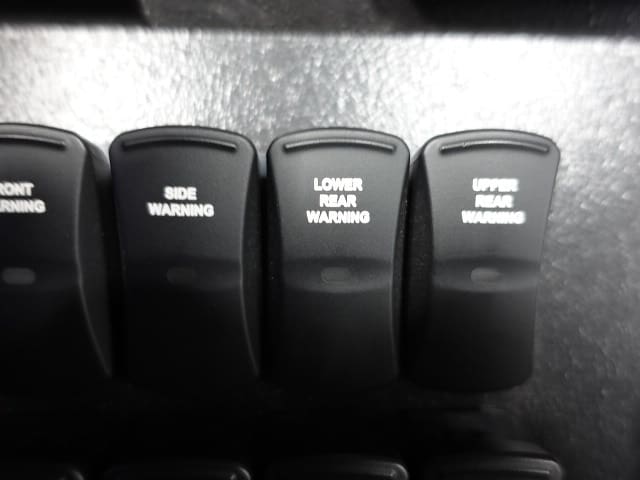

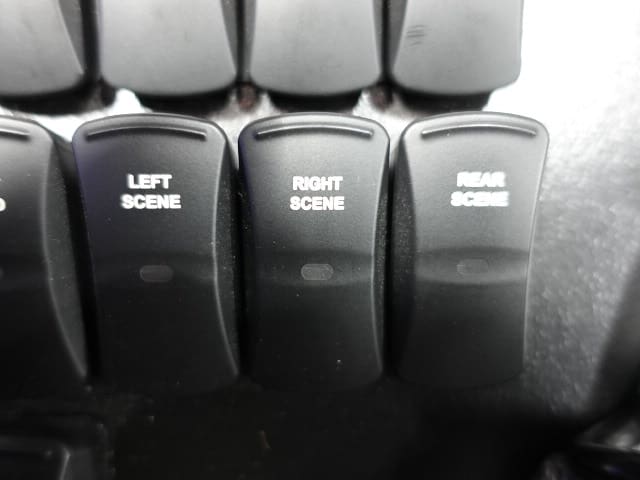

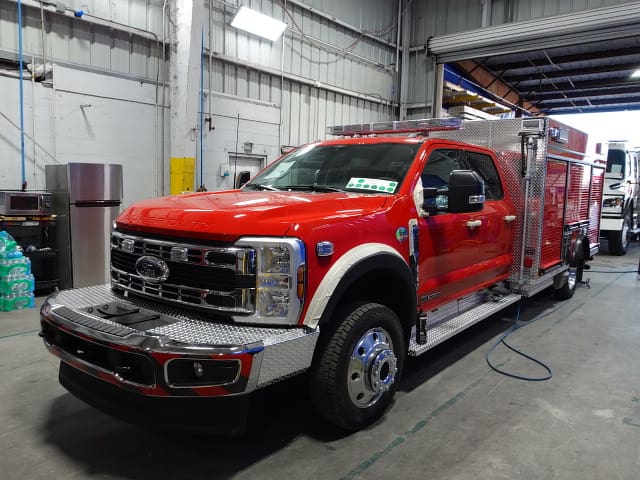

In this report, the apparatus was released to final product evaluation where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
07-18-25

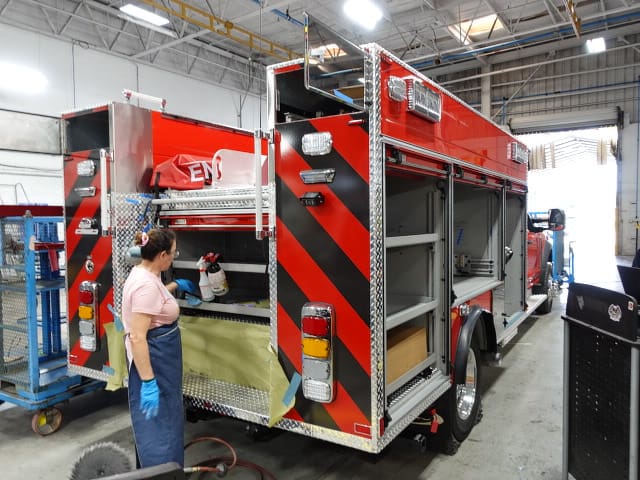

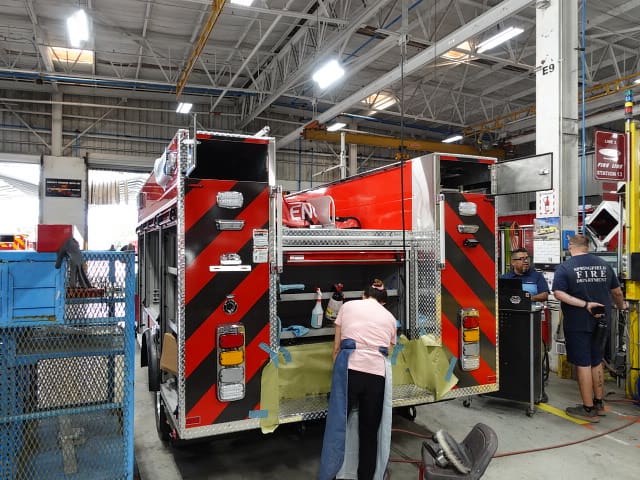

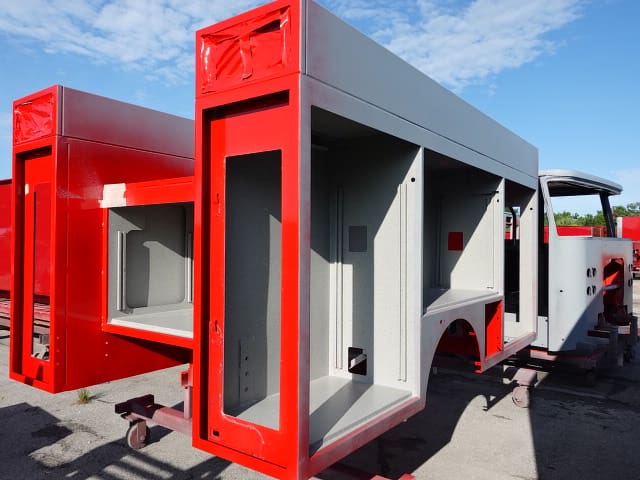

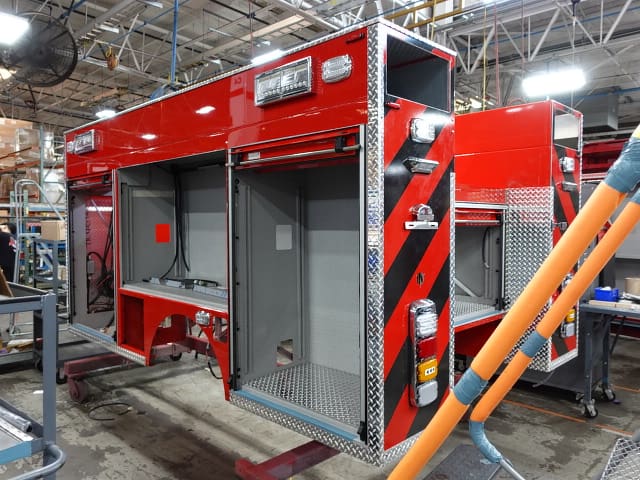

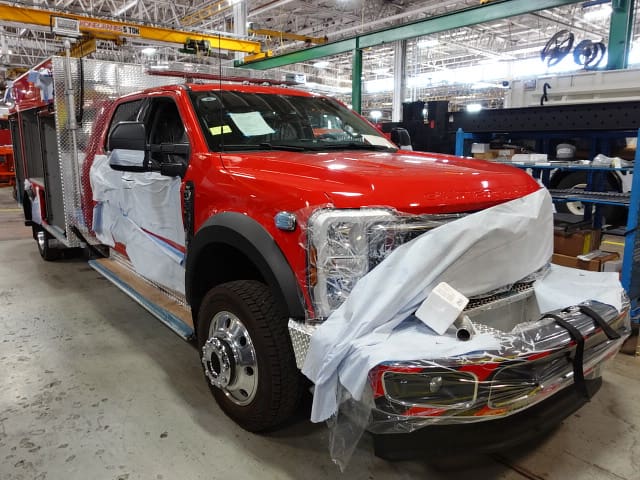

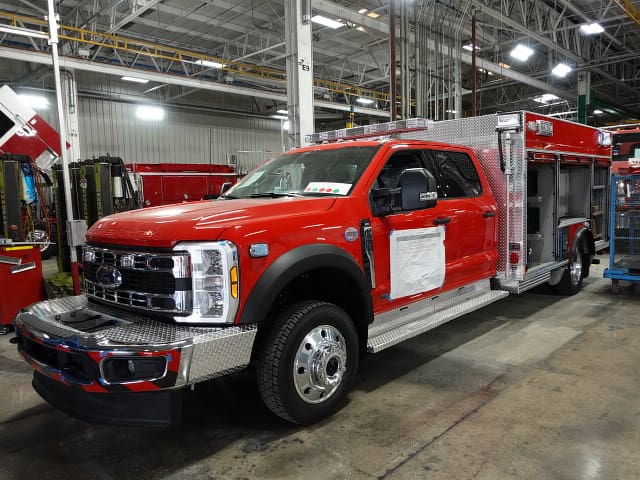

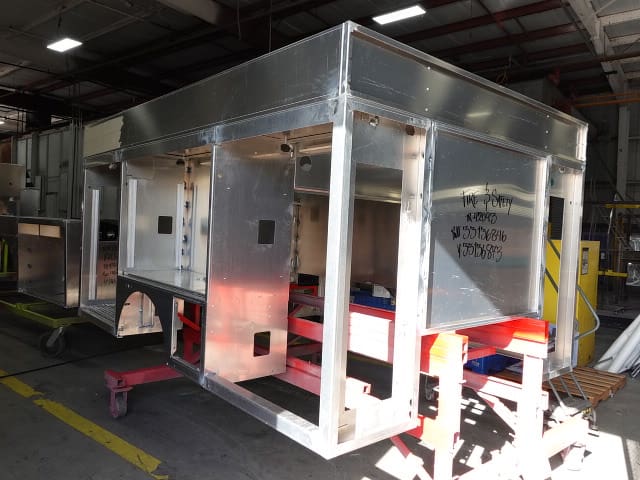

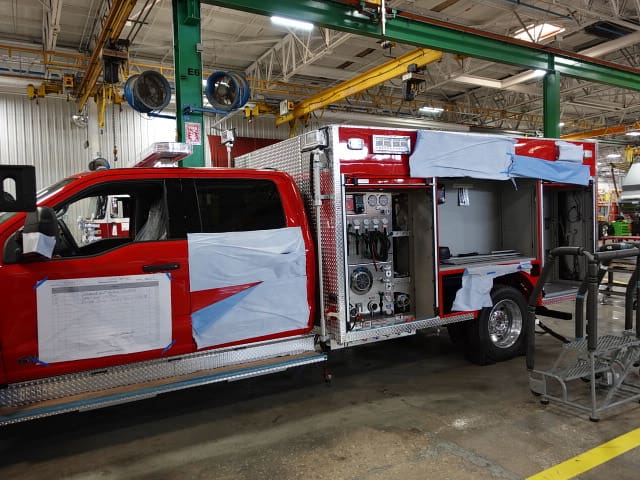

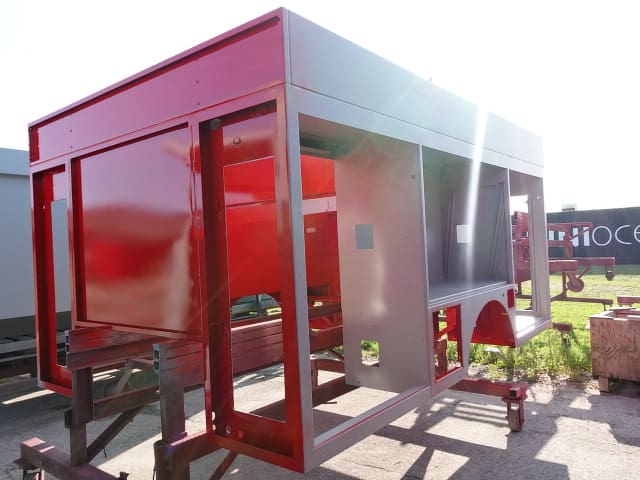

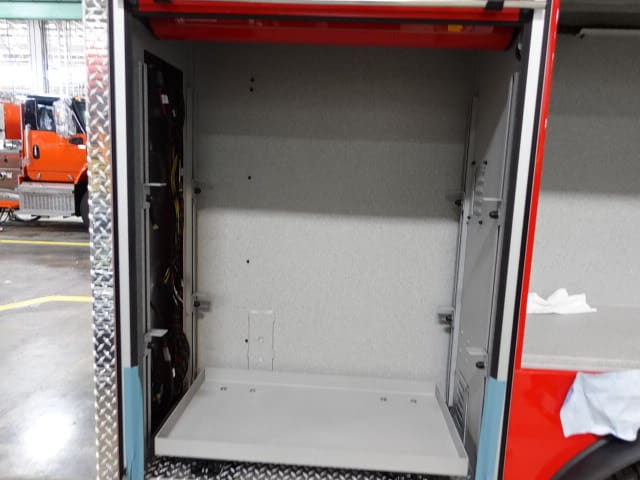

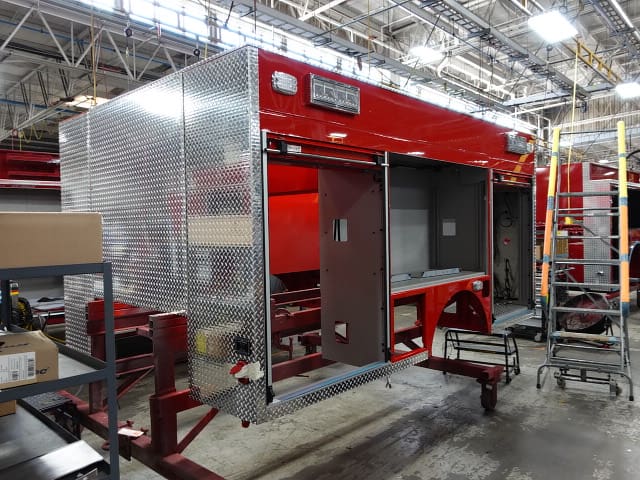

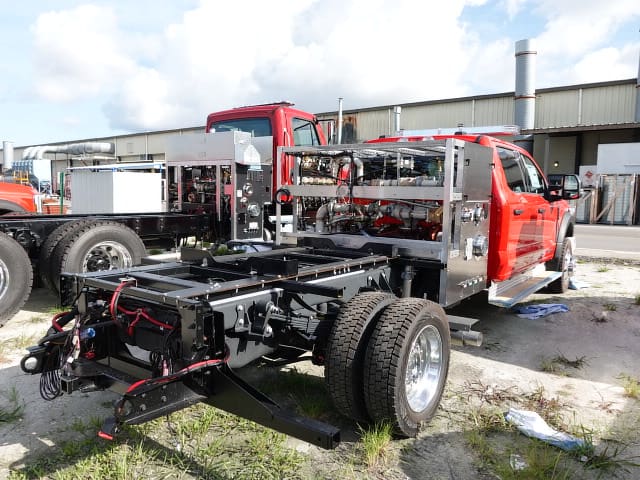

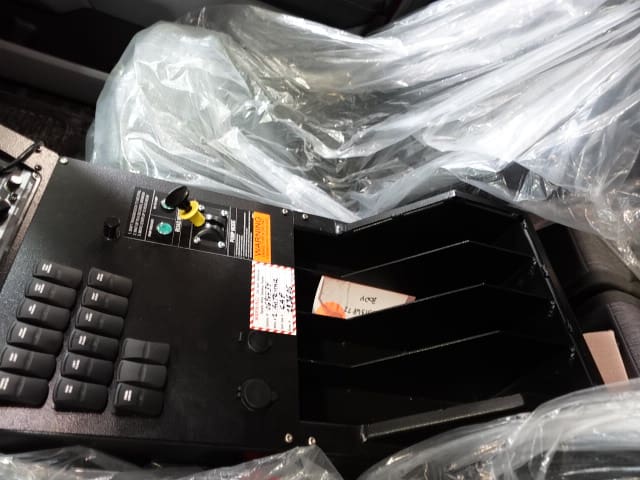

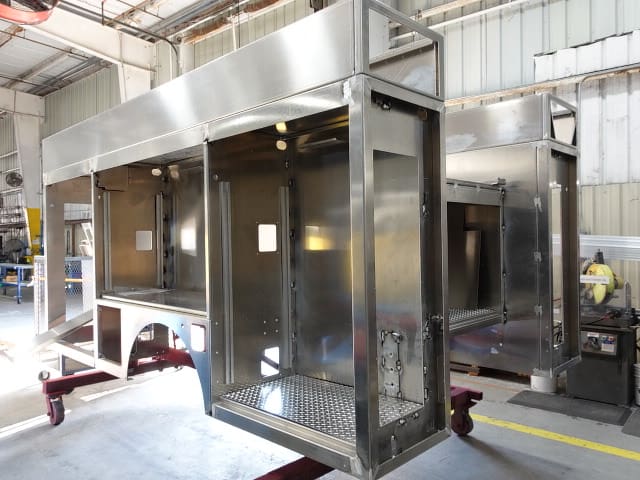

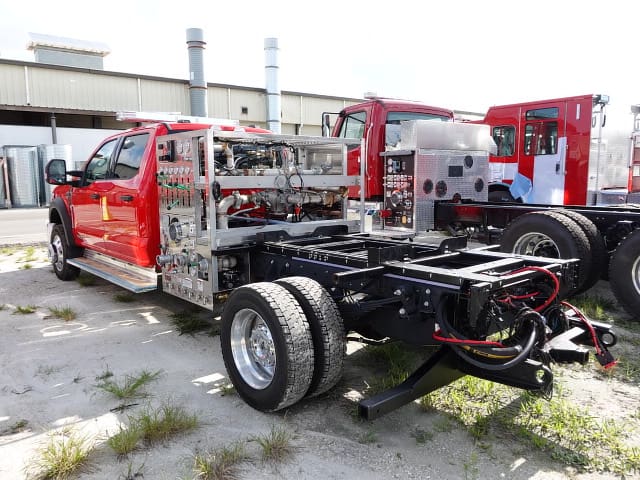

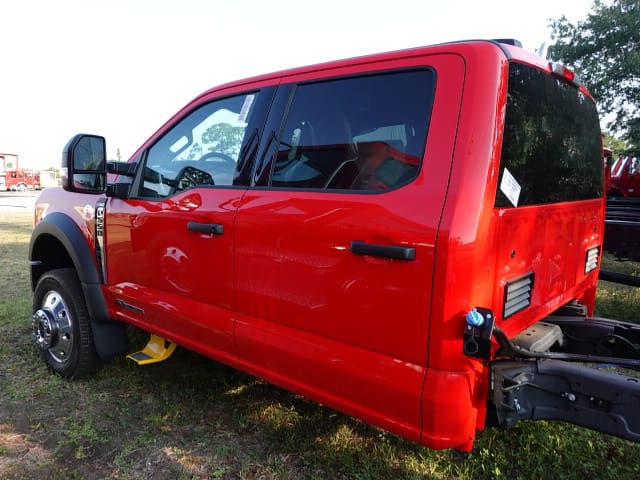

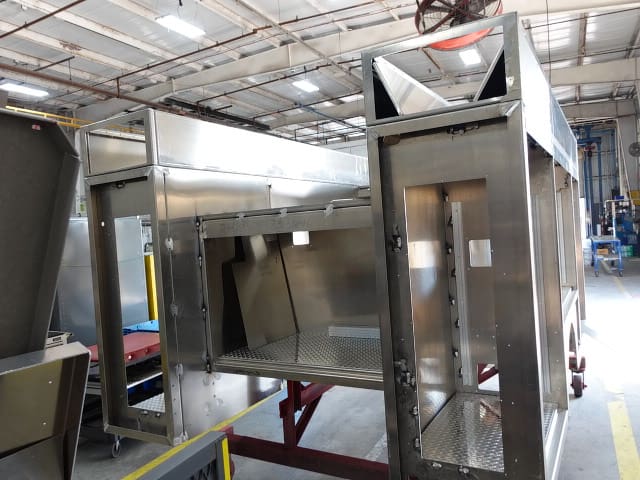

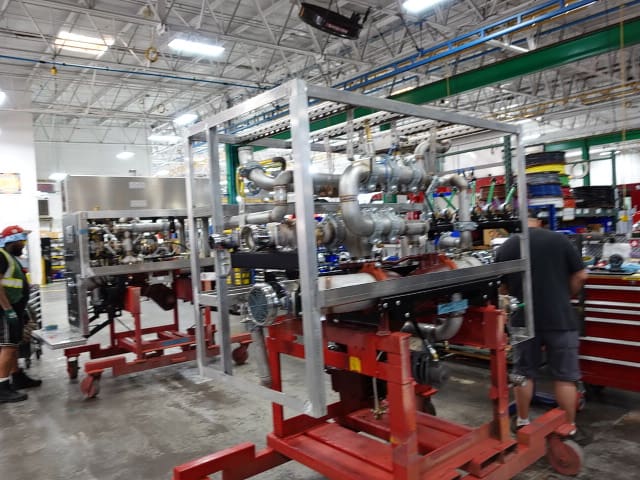

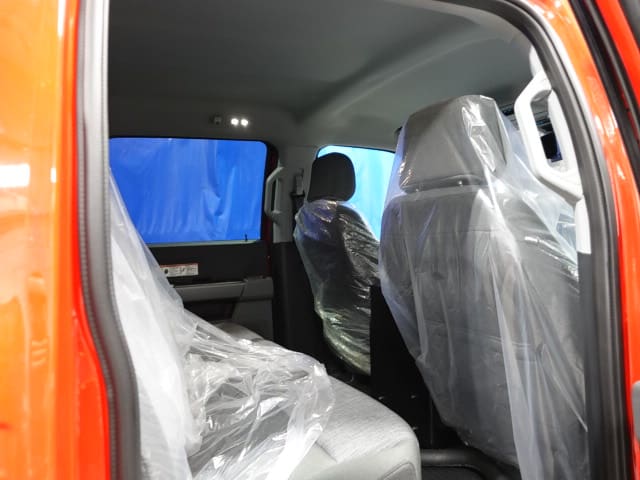

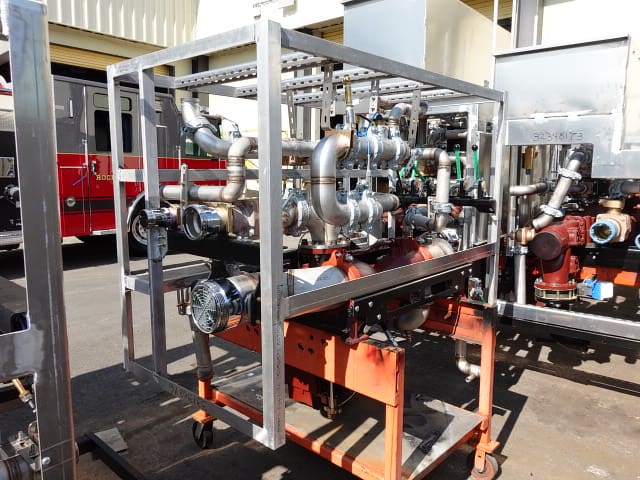

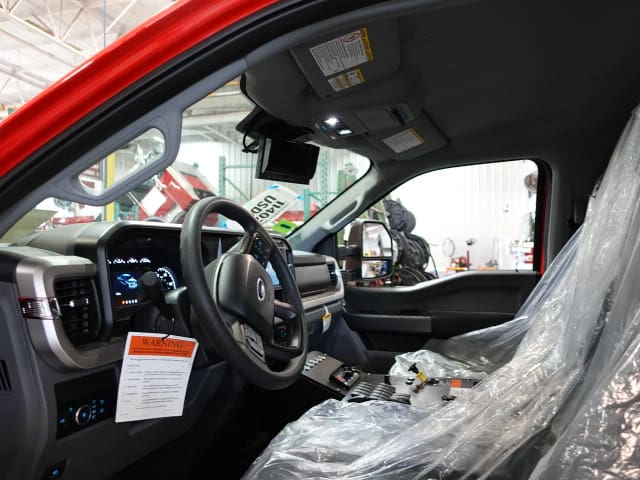

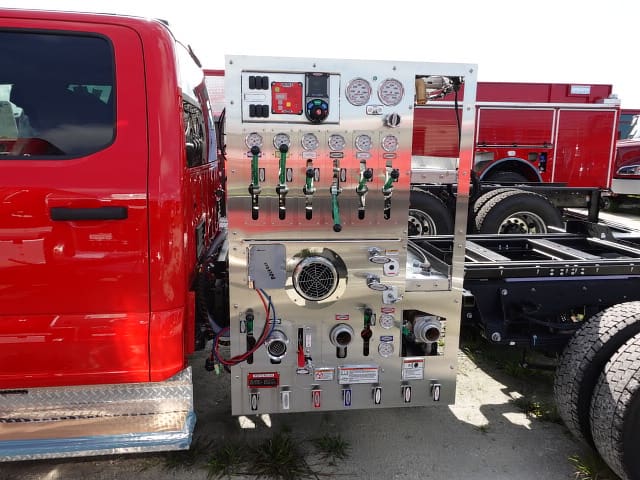

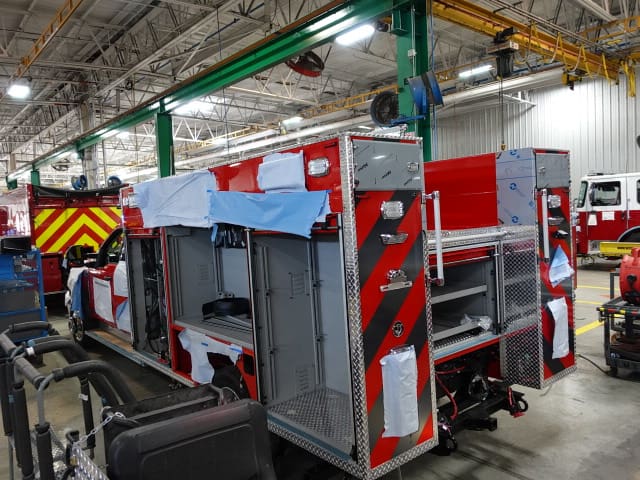

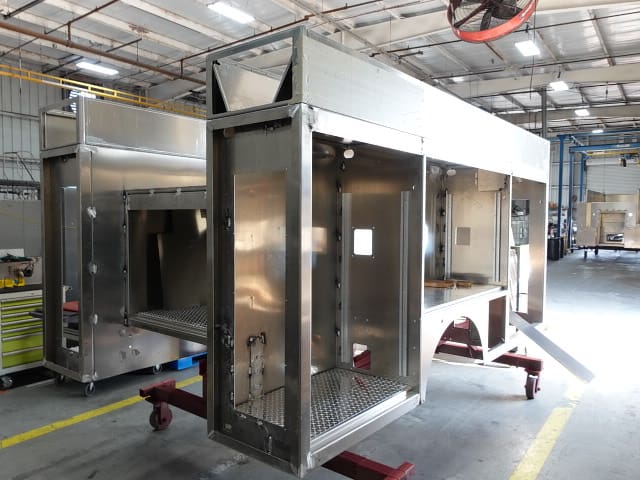

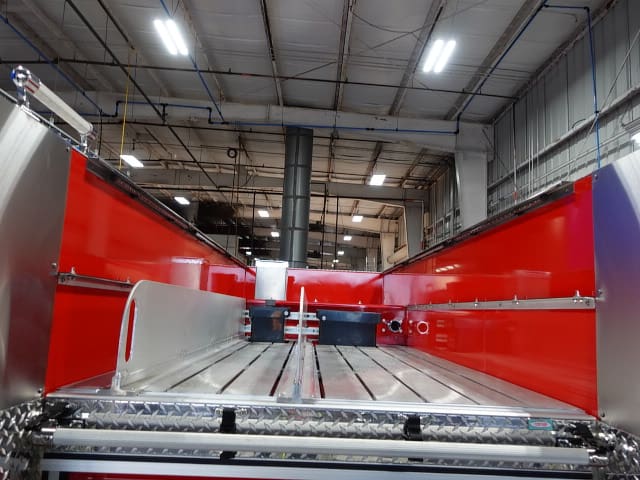

In this report, the body completed initial assembly and was merged with the chassis followed by the start of final assembly.
07-11-25

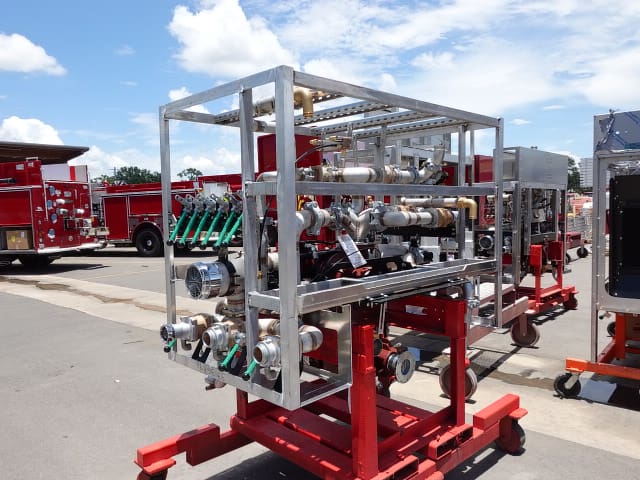

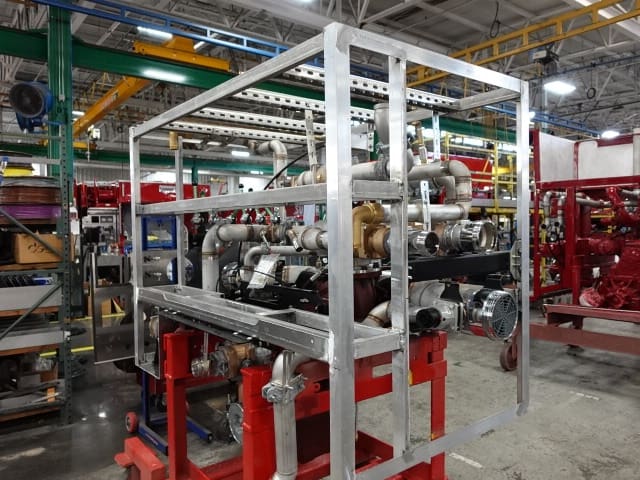

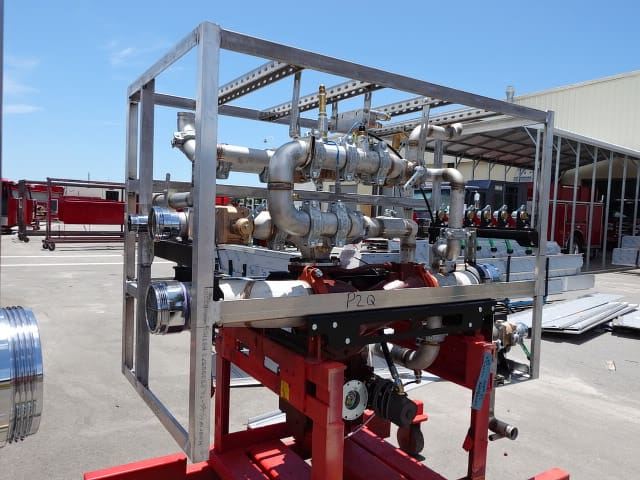

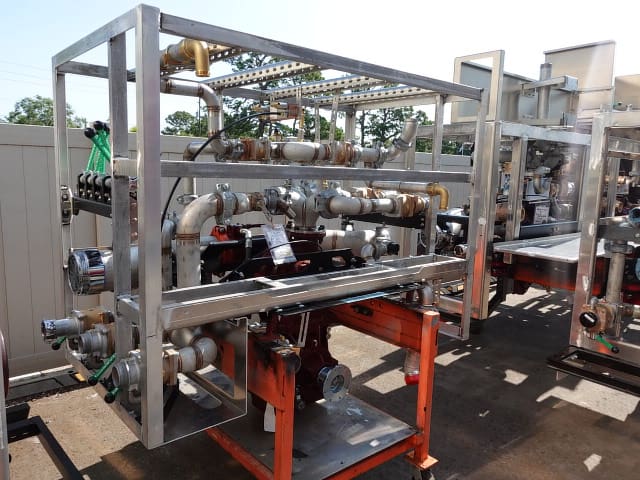

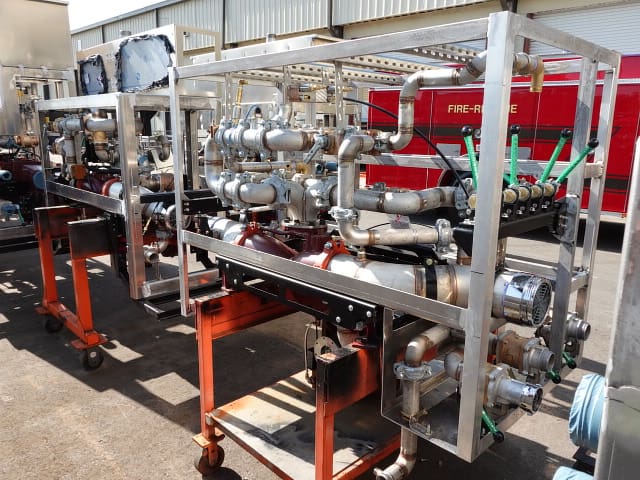

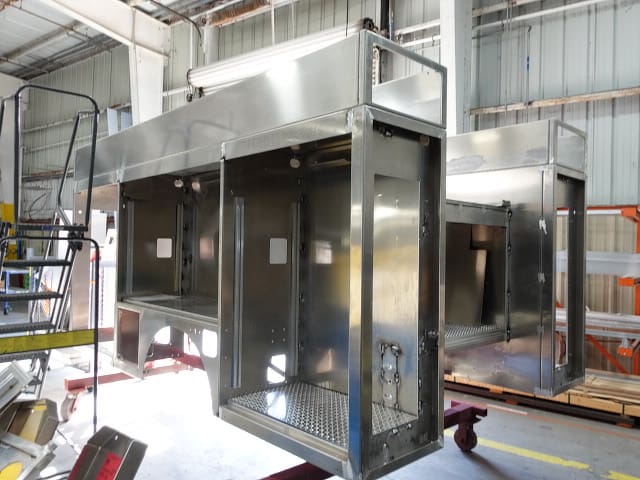

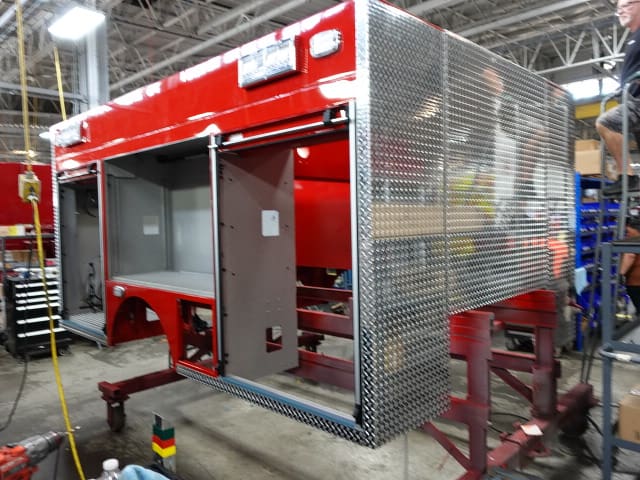

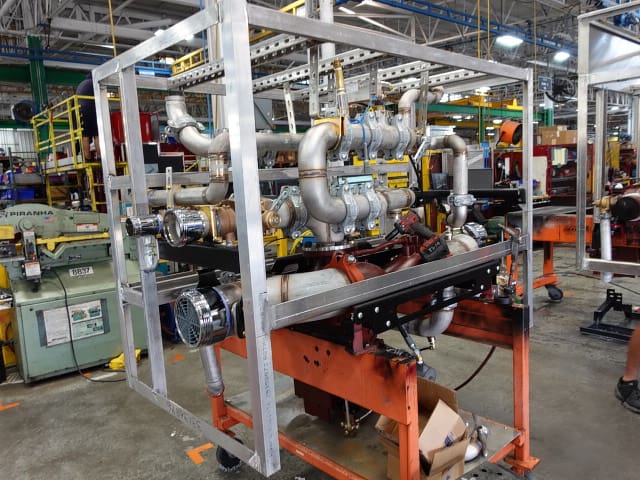

In this report, the pump house completed initial assembly and was merged with the chassis while the body began initial assembly.

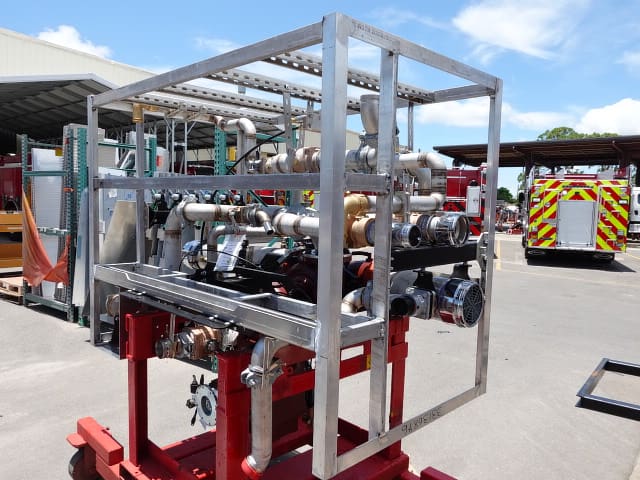

06-20-25

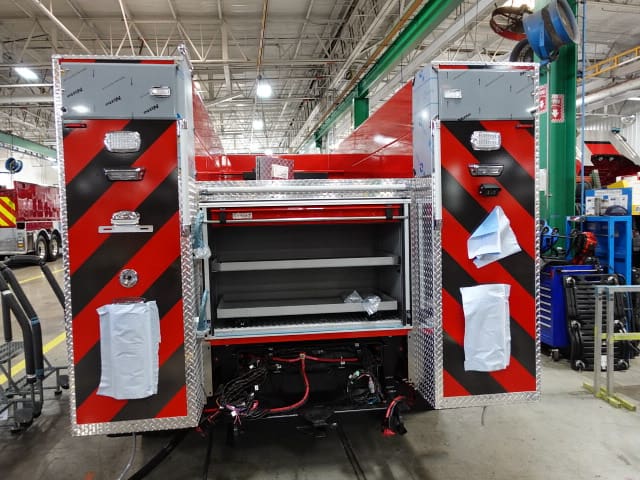

In this report, the commercial chassis was staged (no photos), the pump house continued initial assembly, and the body was staged.
06-13-25

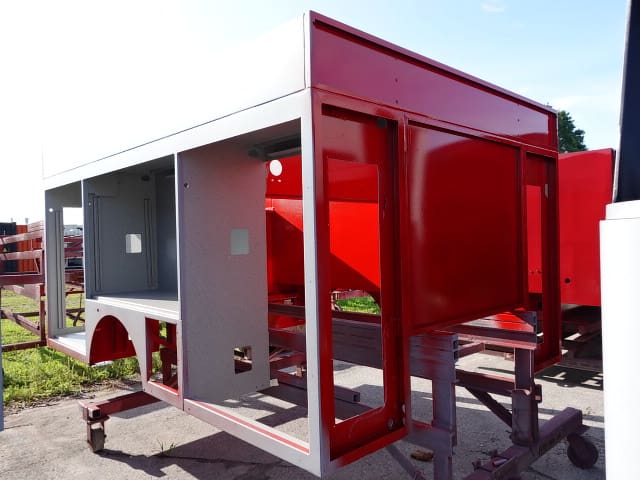

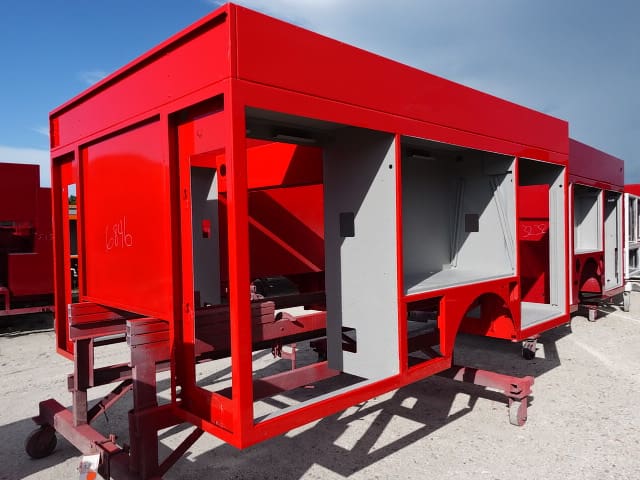

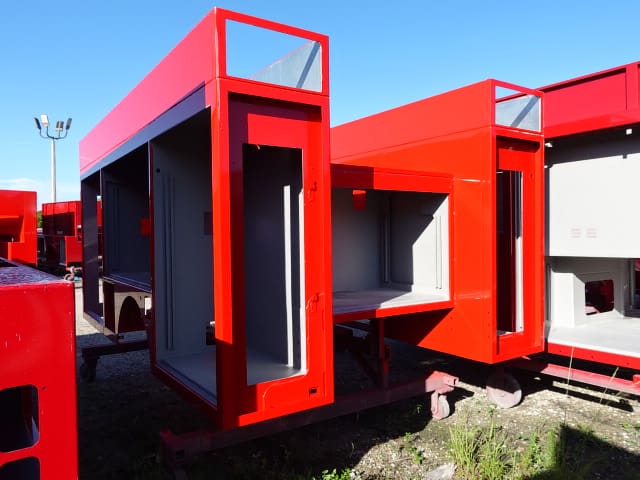

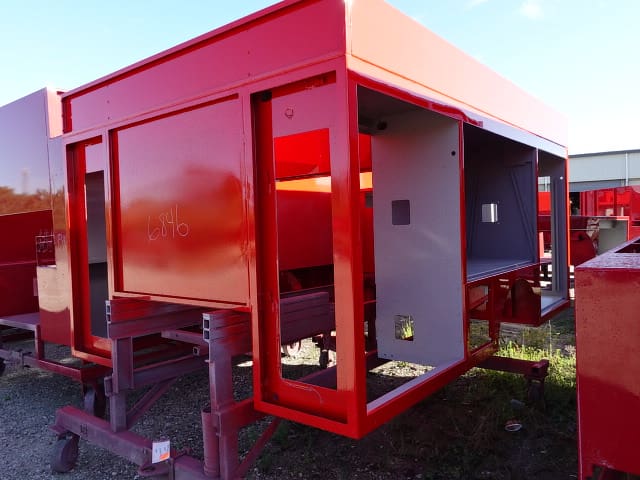

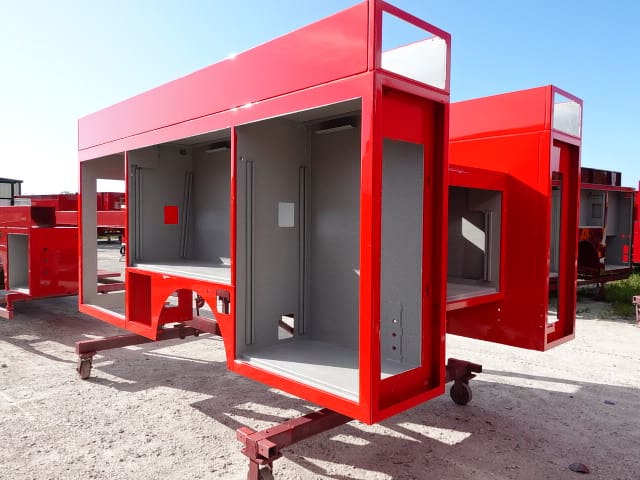

In this report, the commercial chassis remained staged (no photos), the pump house was staged, and the body completed the paint process.

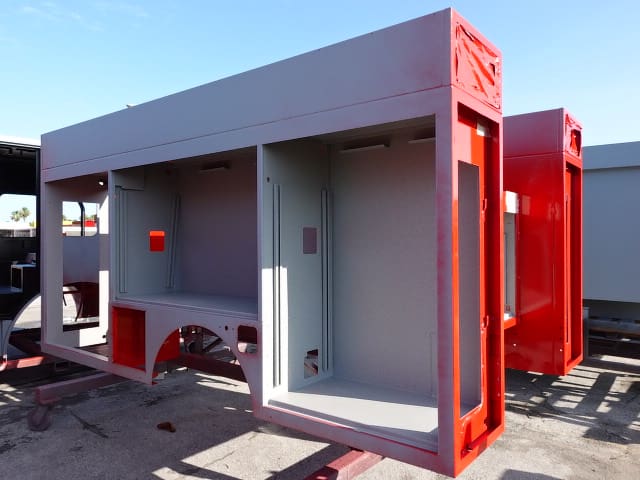

06-06-25

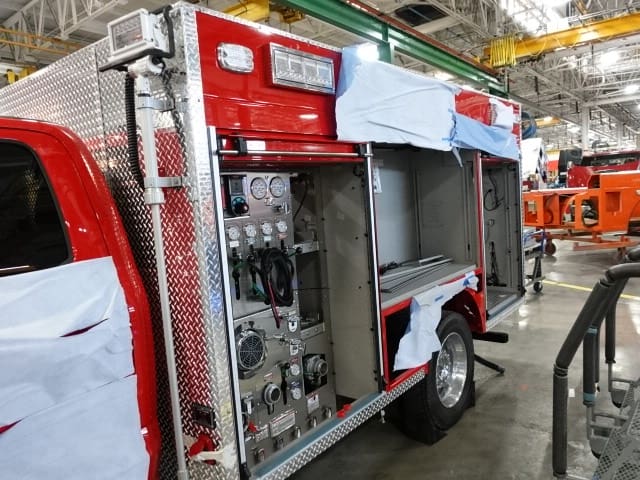

In this report, the commercial chassis remained staged (no photos), the pump house continued initial assembly, and the body completed fabrication and began the paint process.
05-30-25

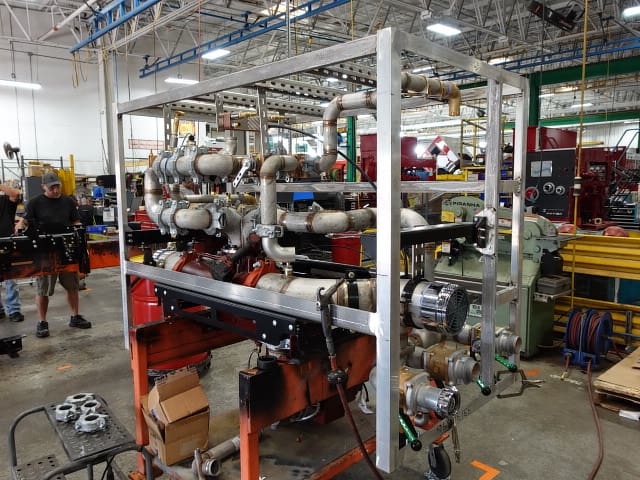

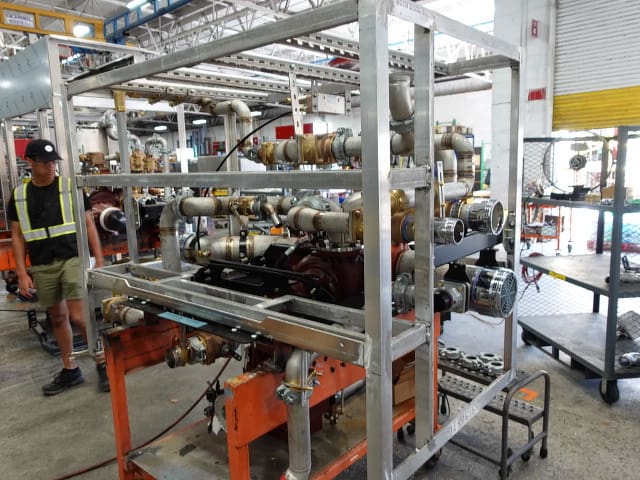

In this report, the commercial chassis remained staged (no photos), the pump house began initial assembly, and the body continued fabrication.
05-23-25

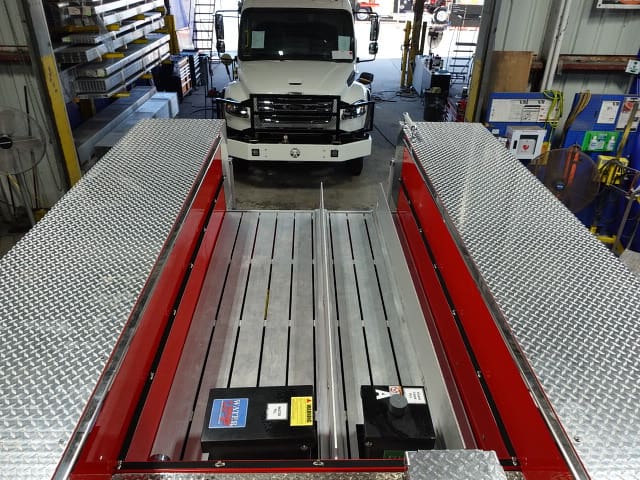

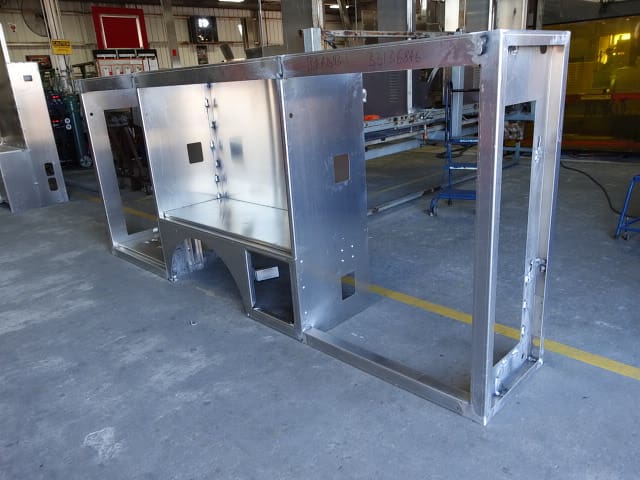

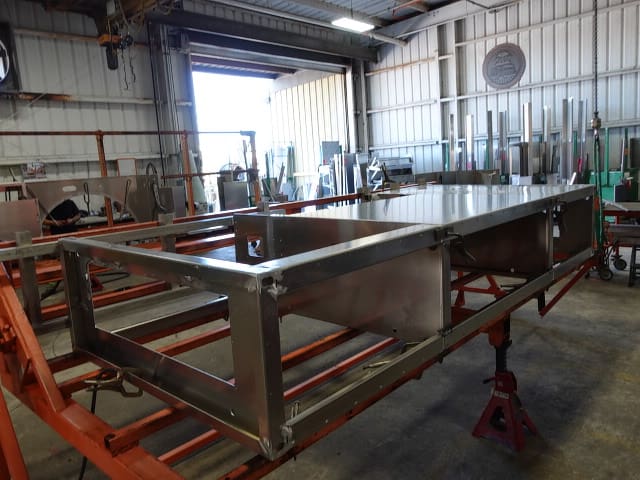

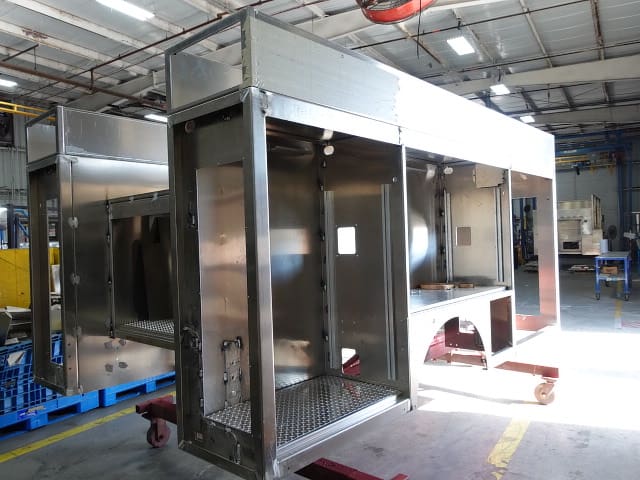

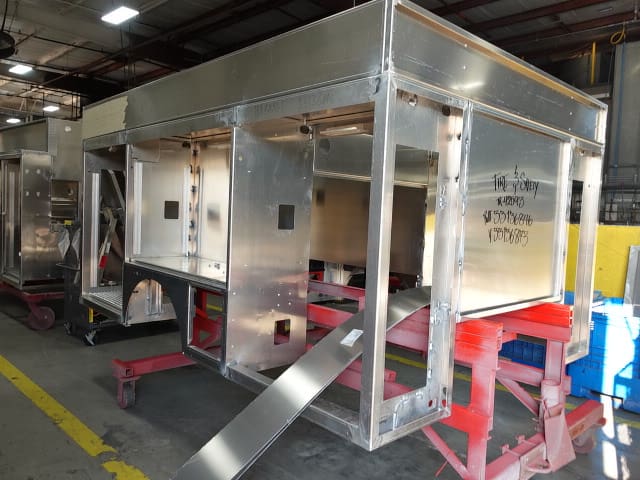

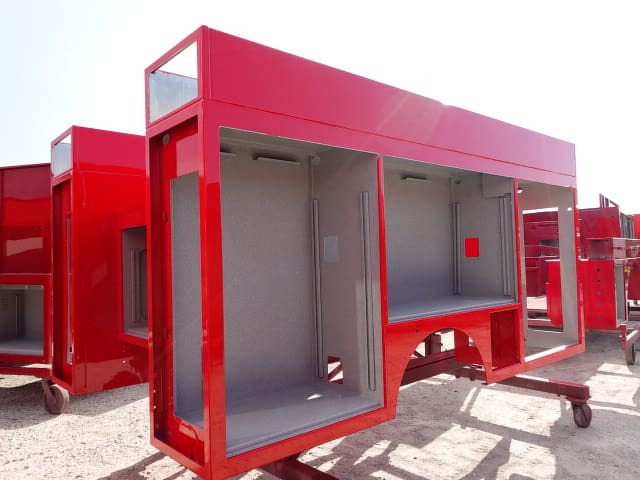

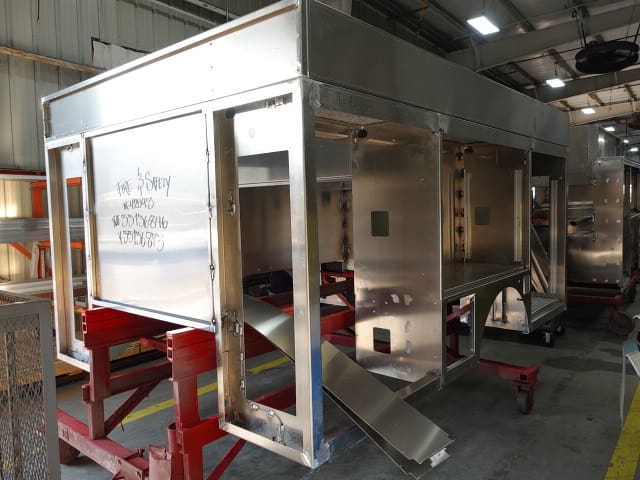

In this report, the commercial chassis arrived and was staged while the body continued fabrication.

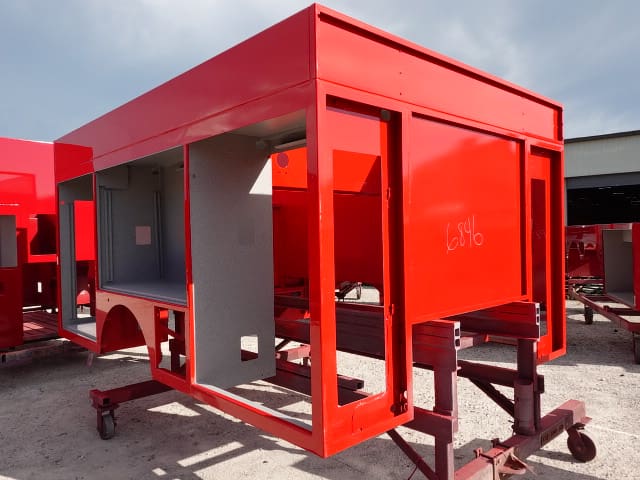

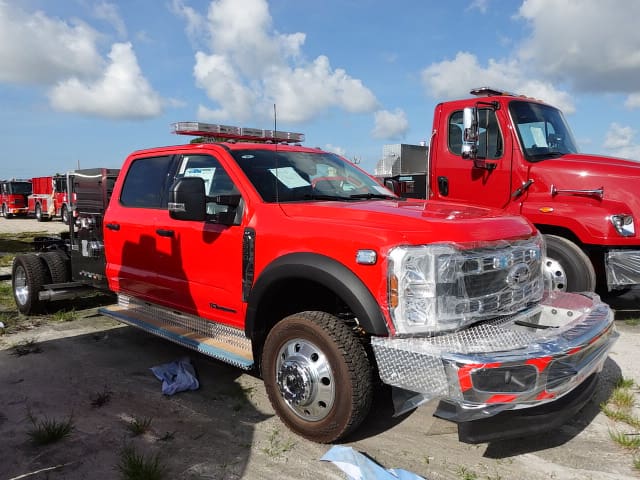

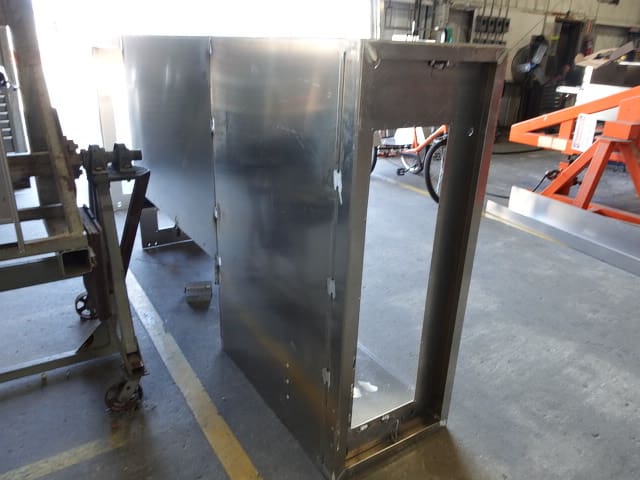

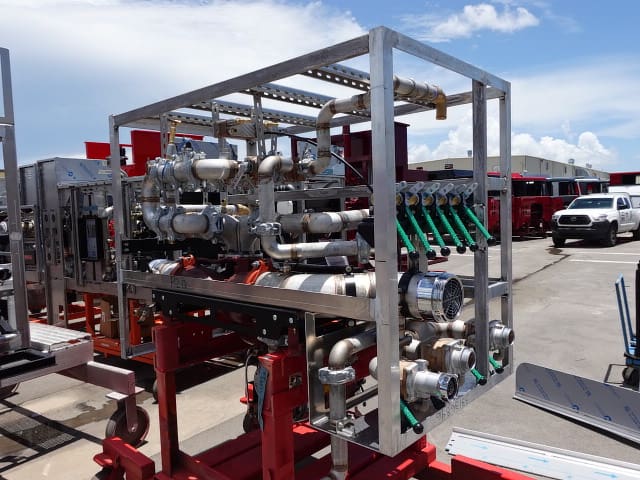

05-16-25

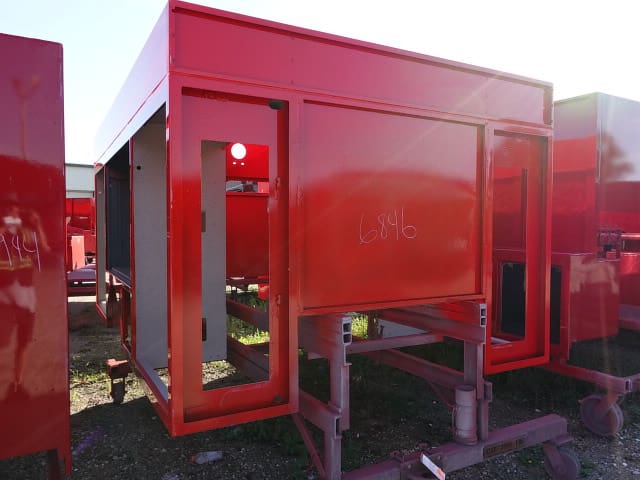

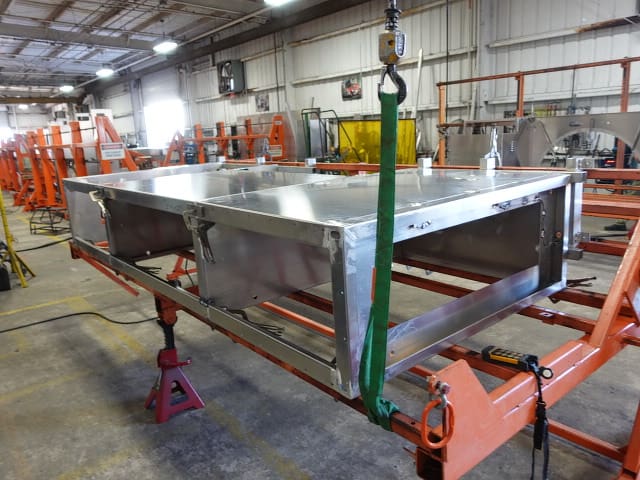

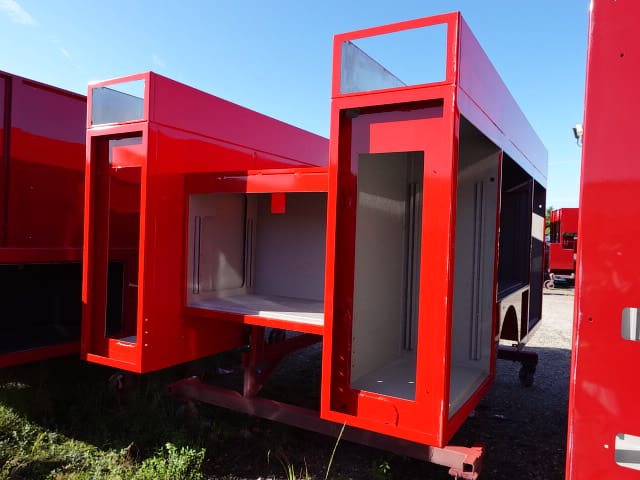

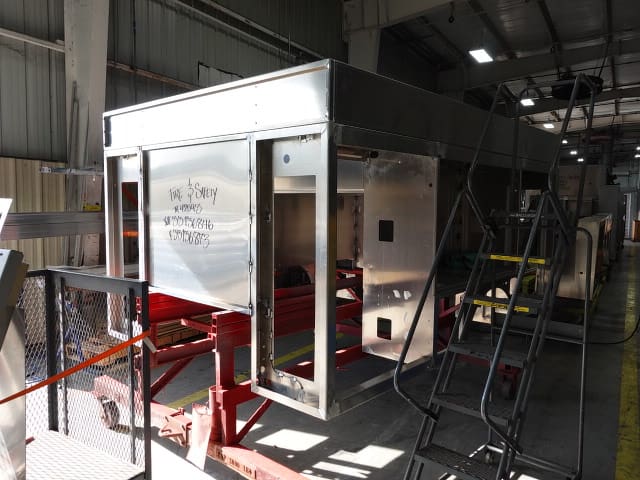

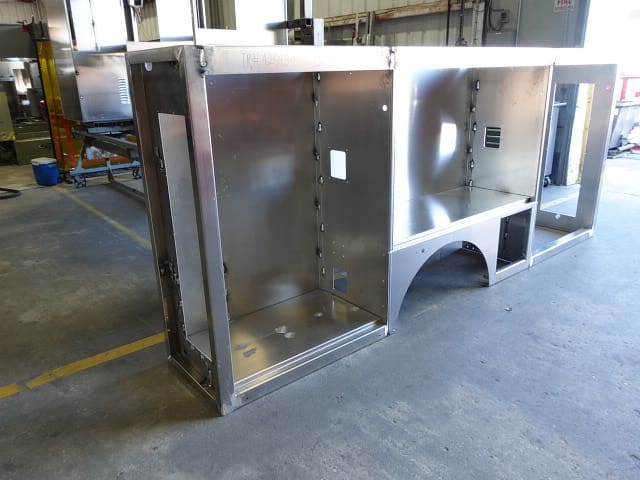

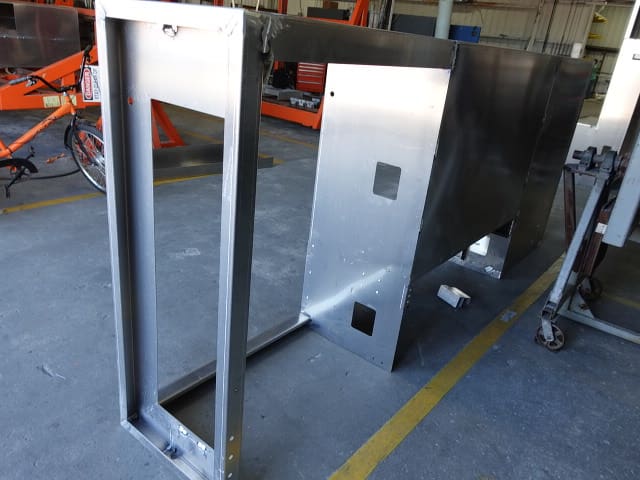

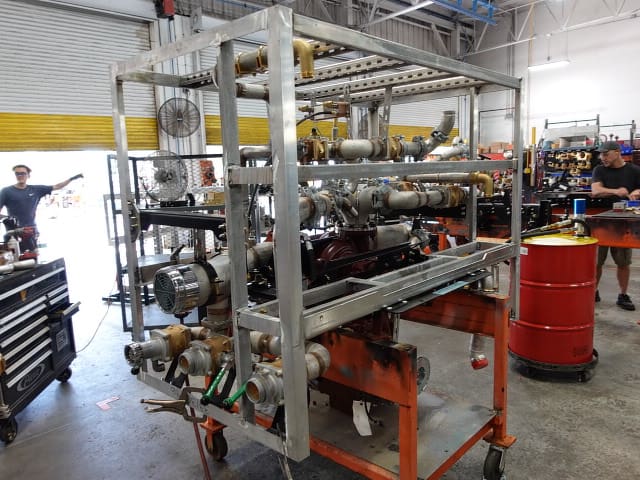

This new Pierce apparatus is now in production! In this report, the body began fabrication.
