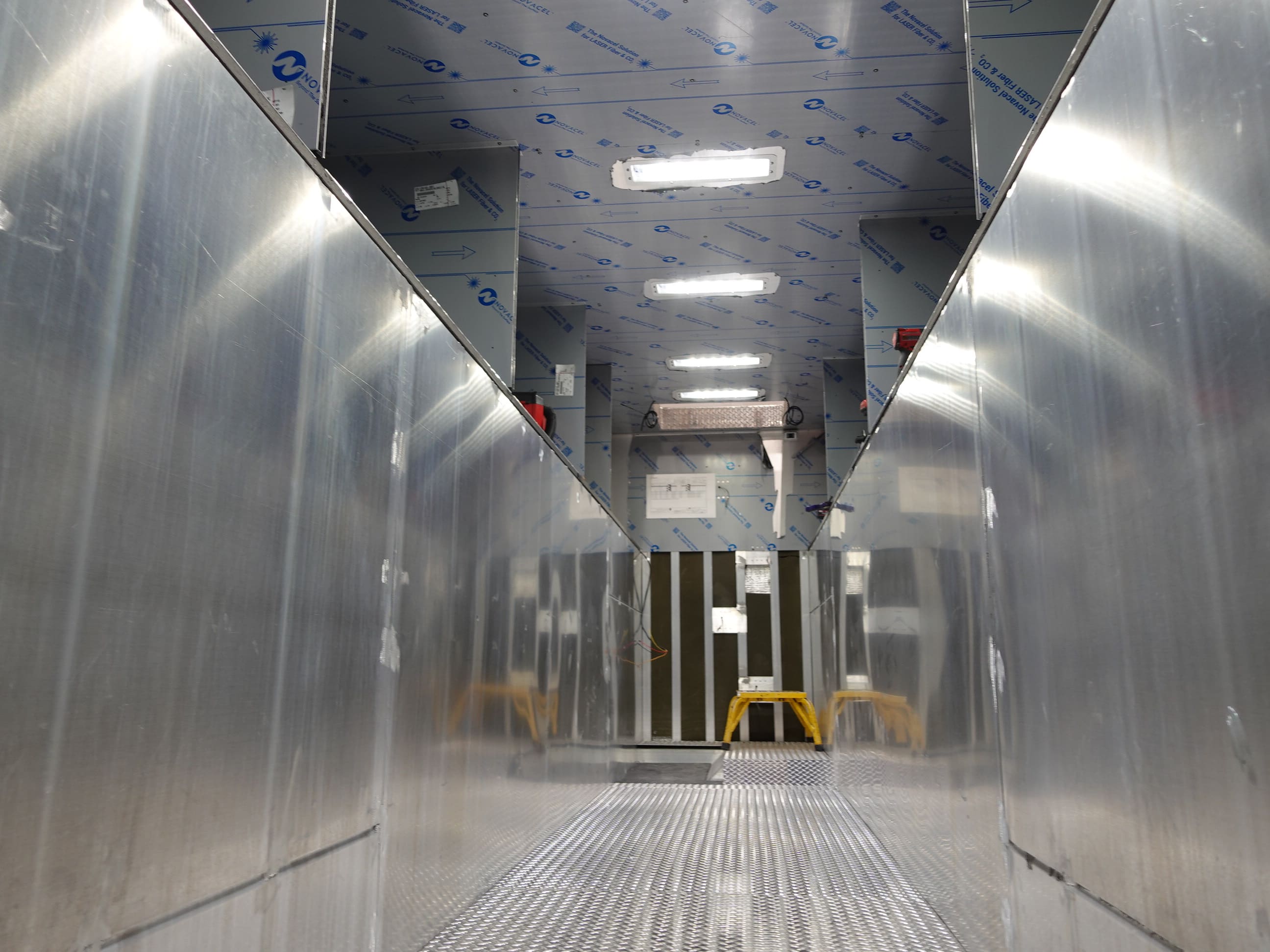

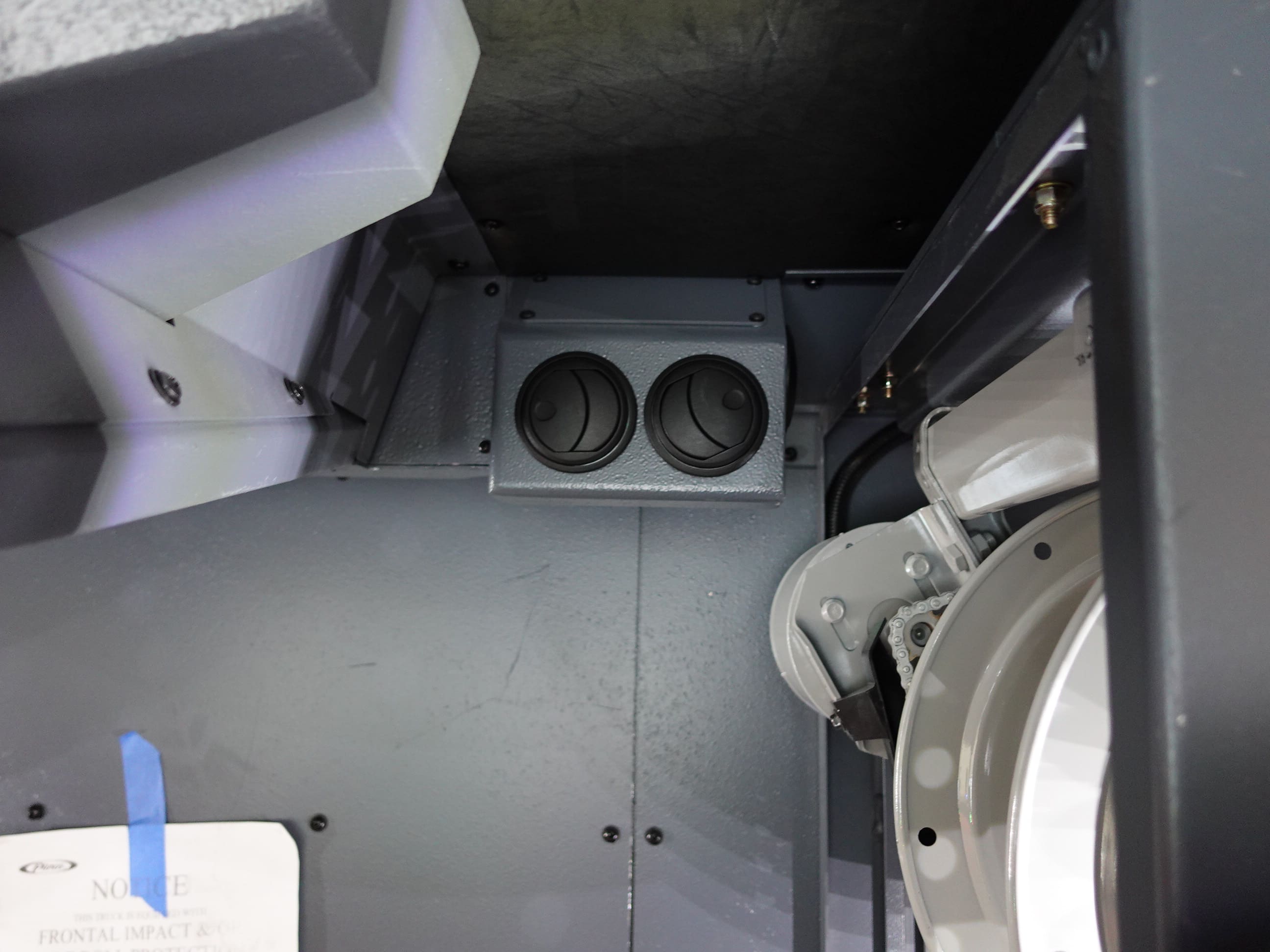

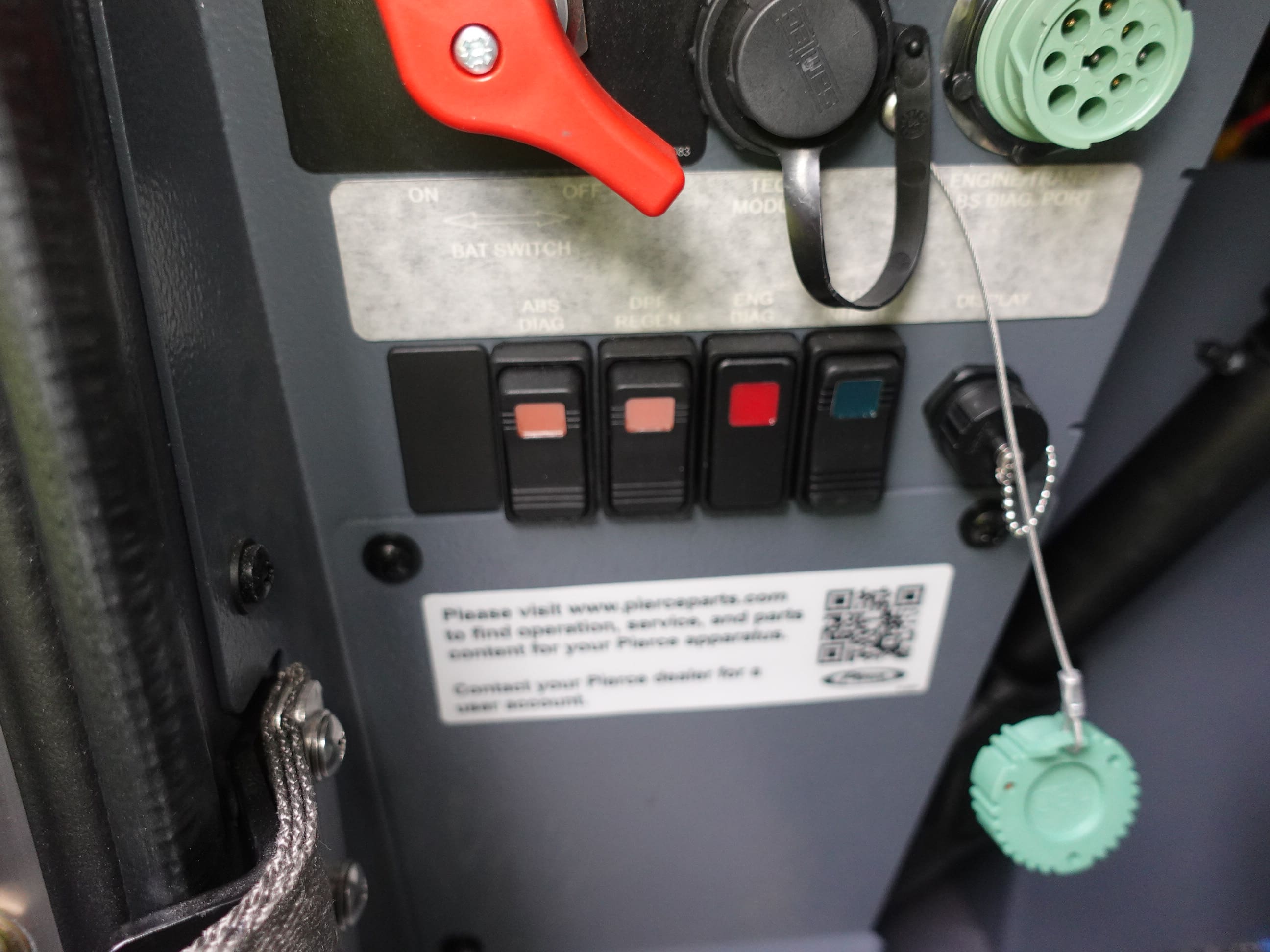

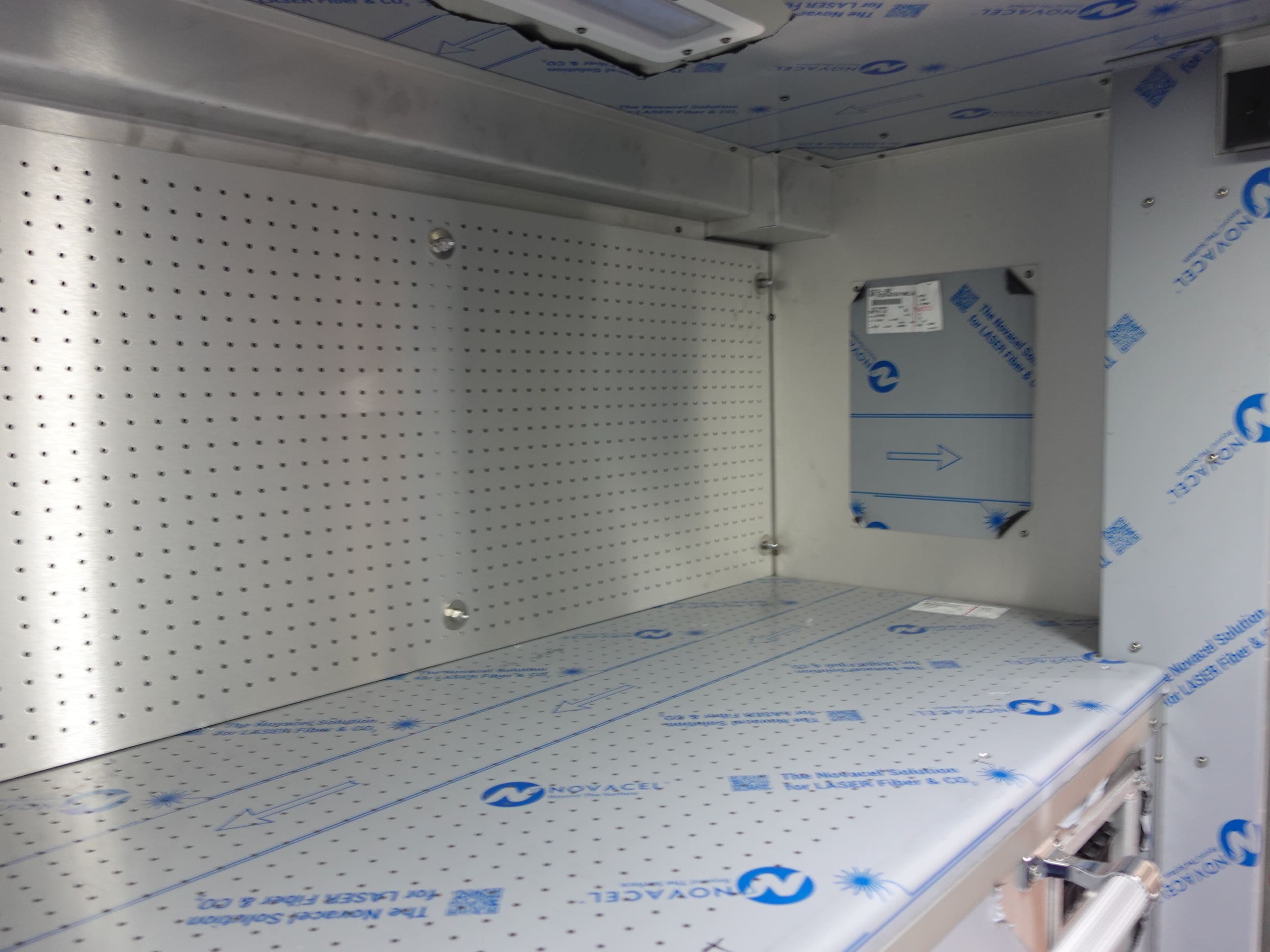

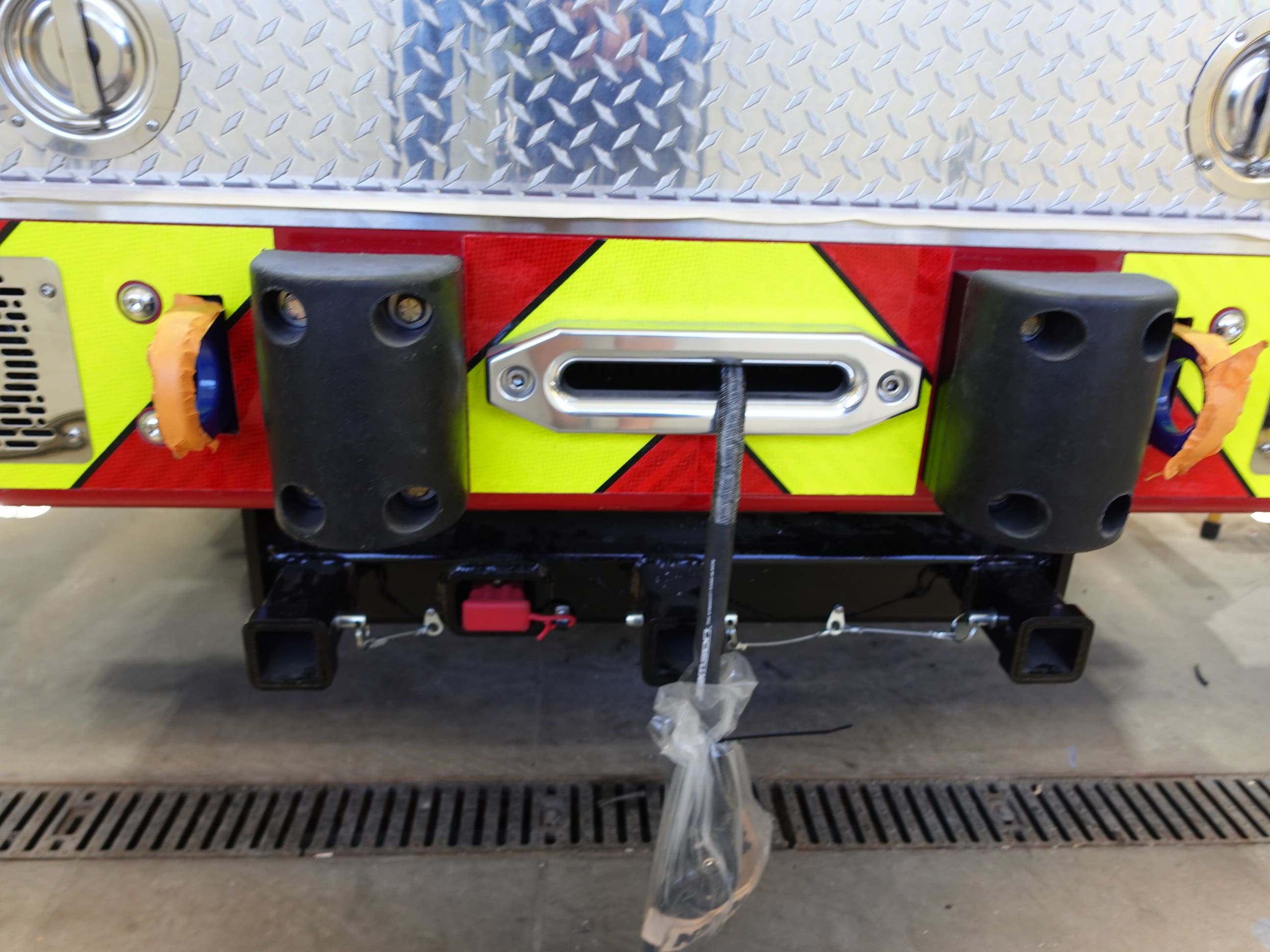

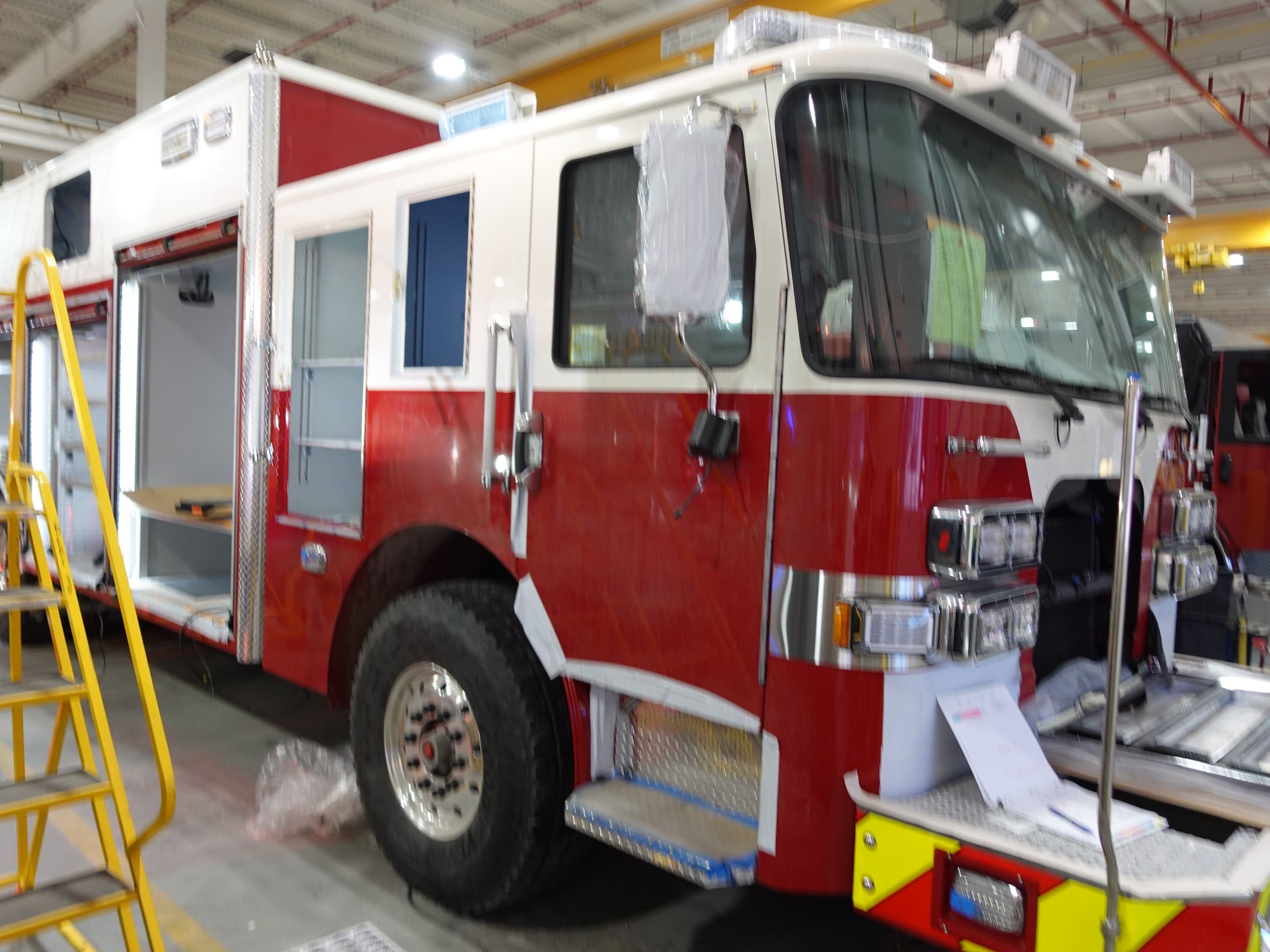

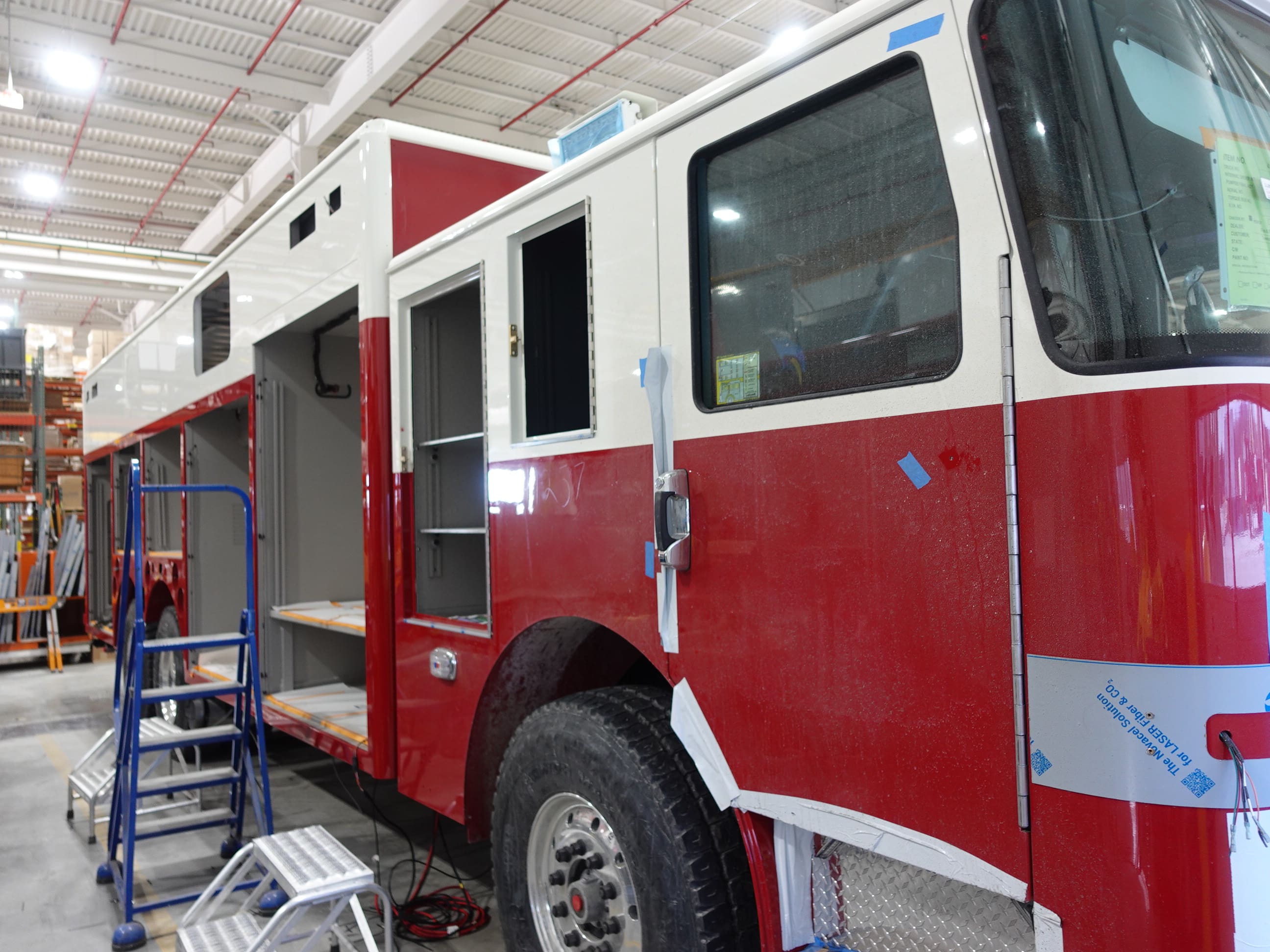

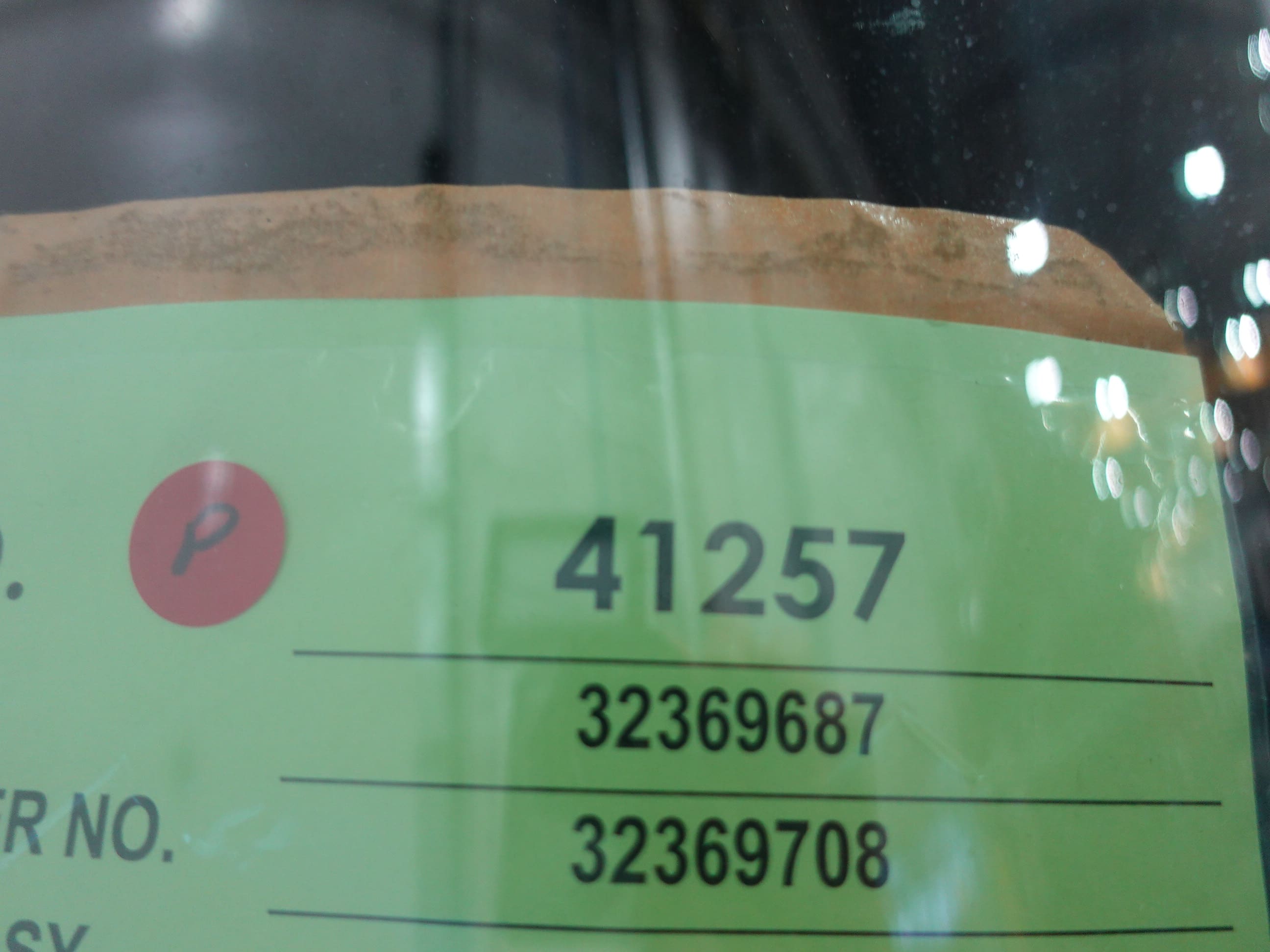

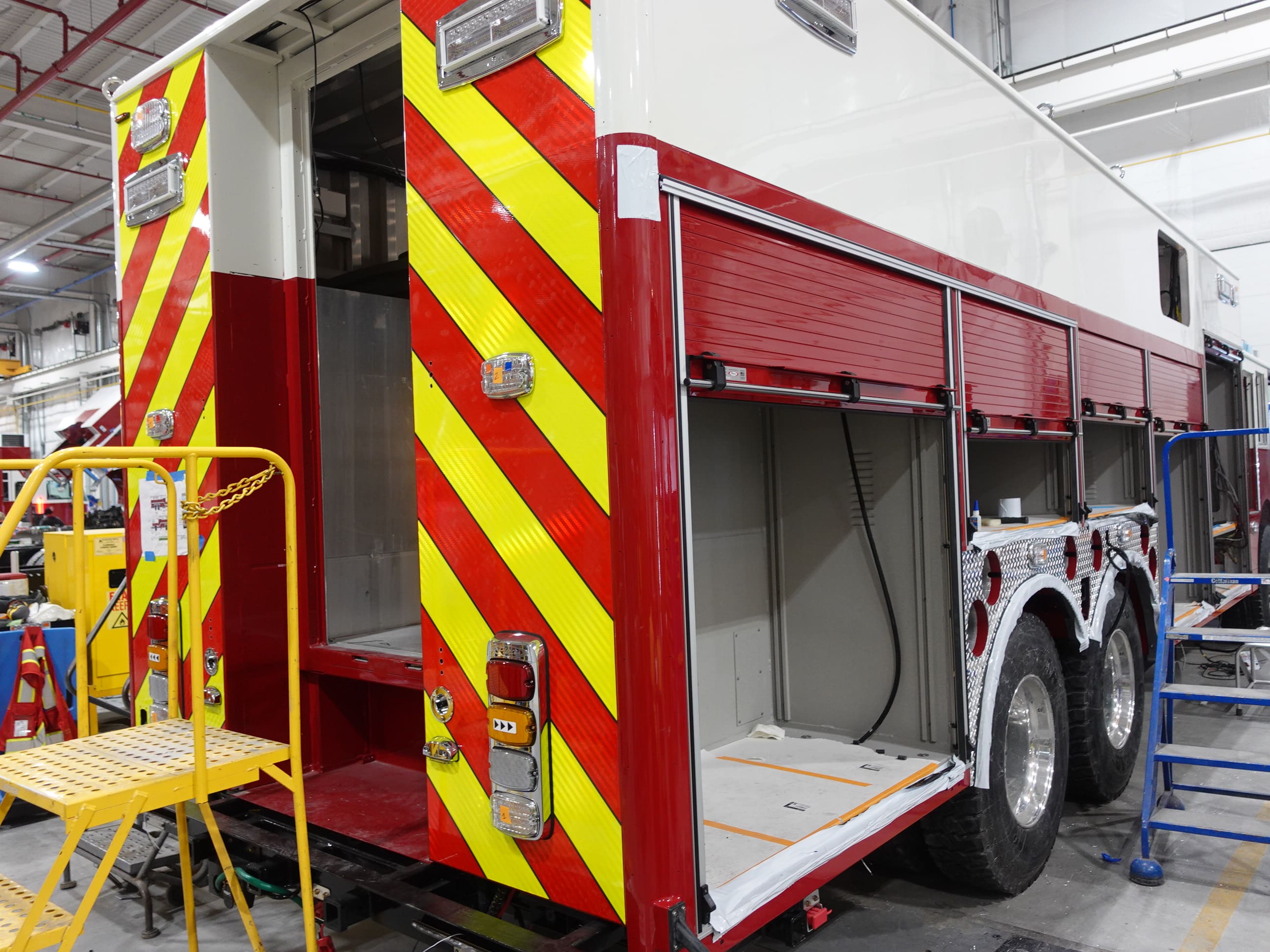

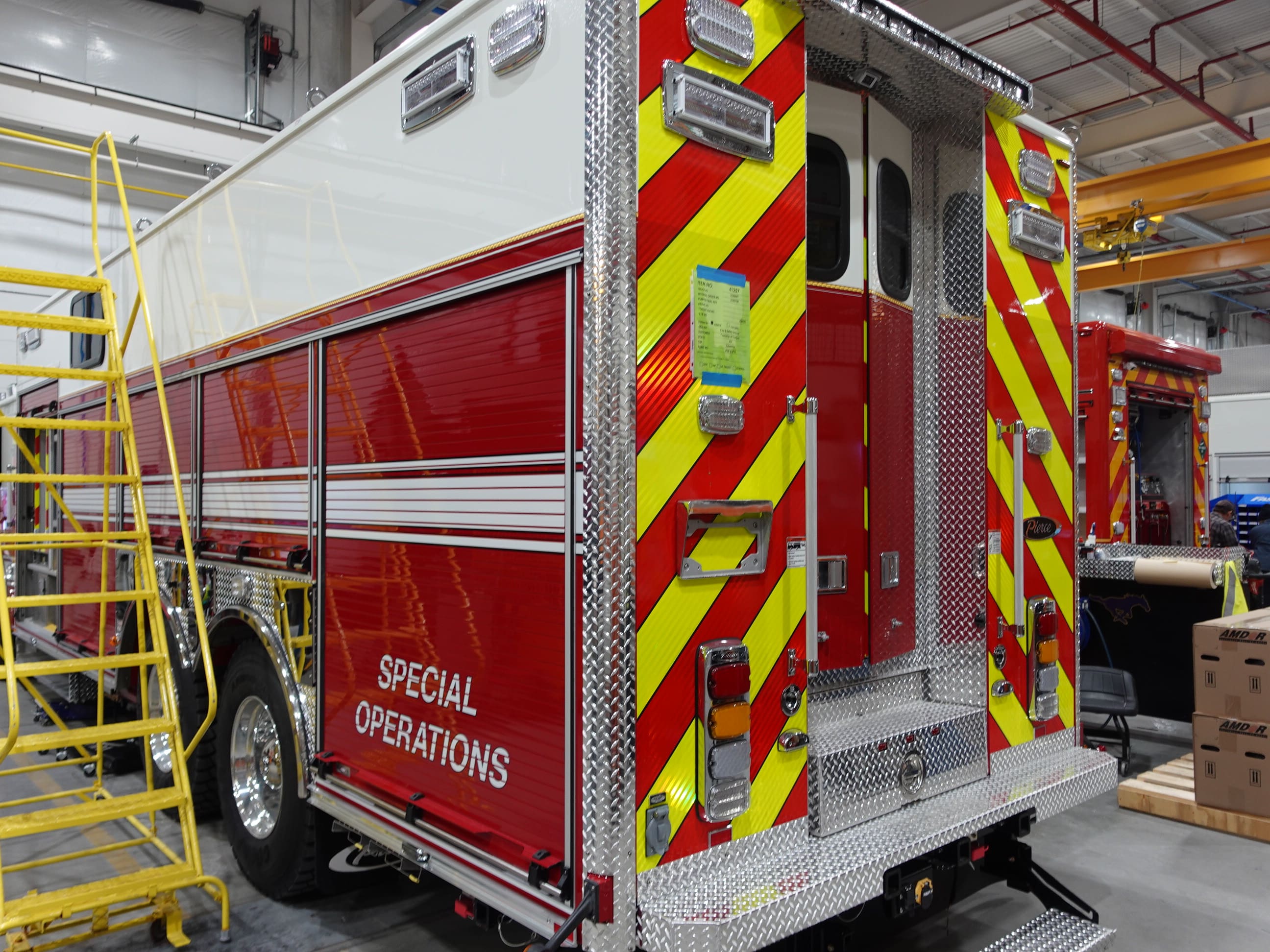

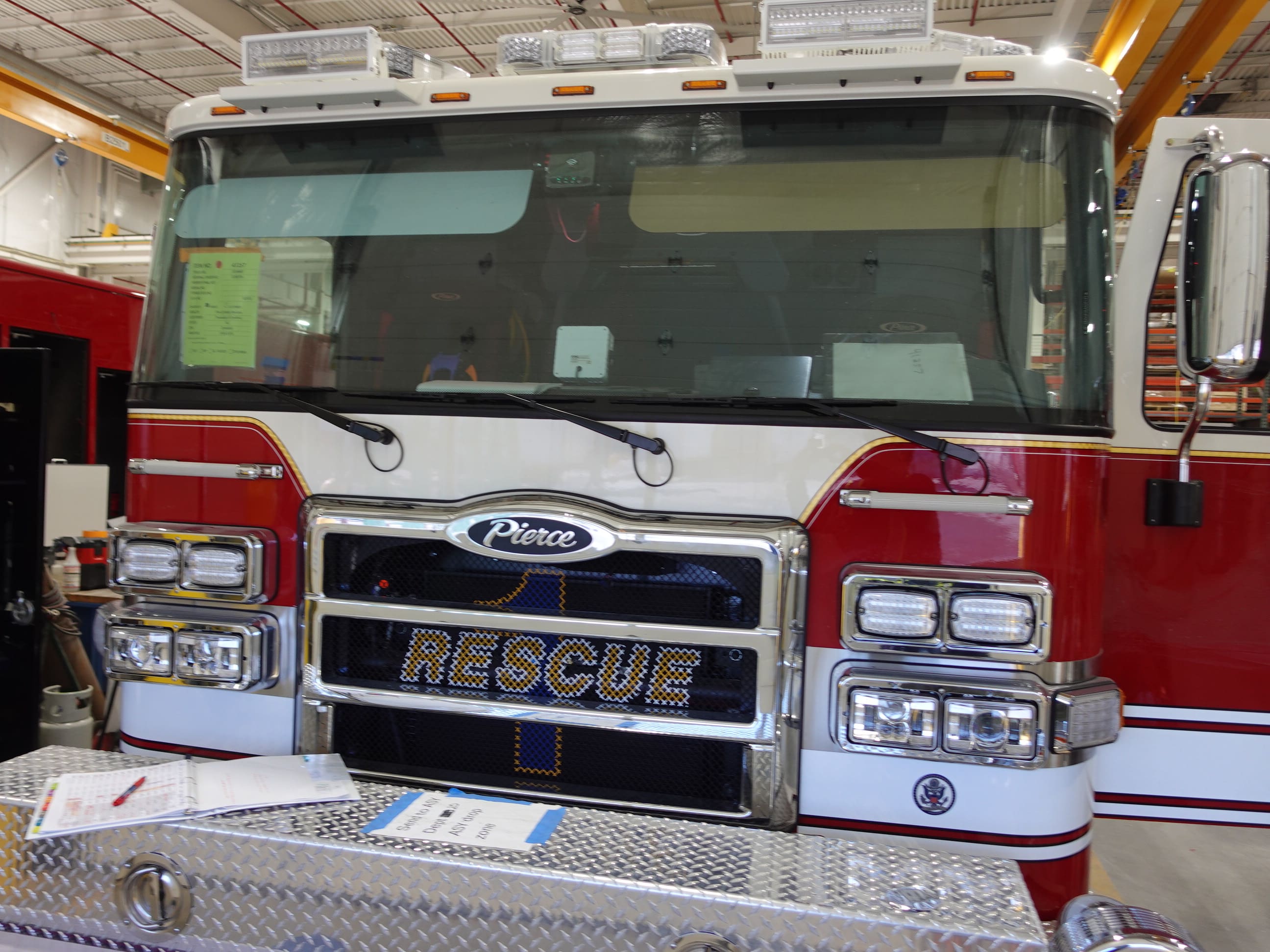

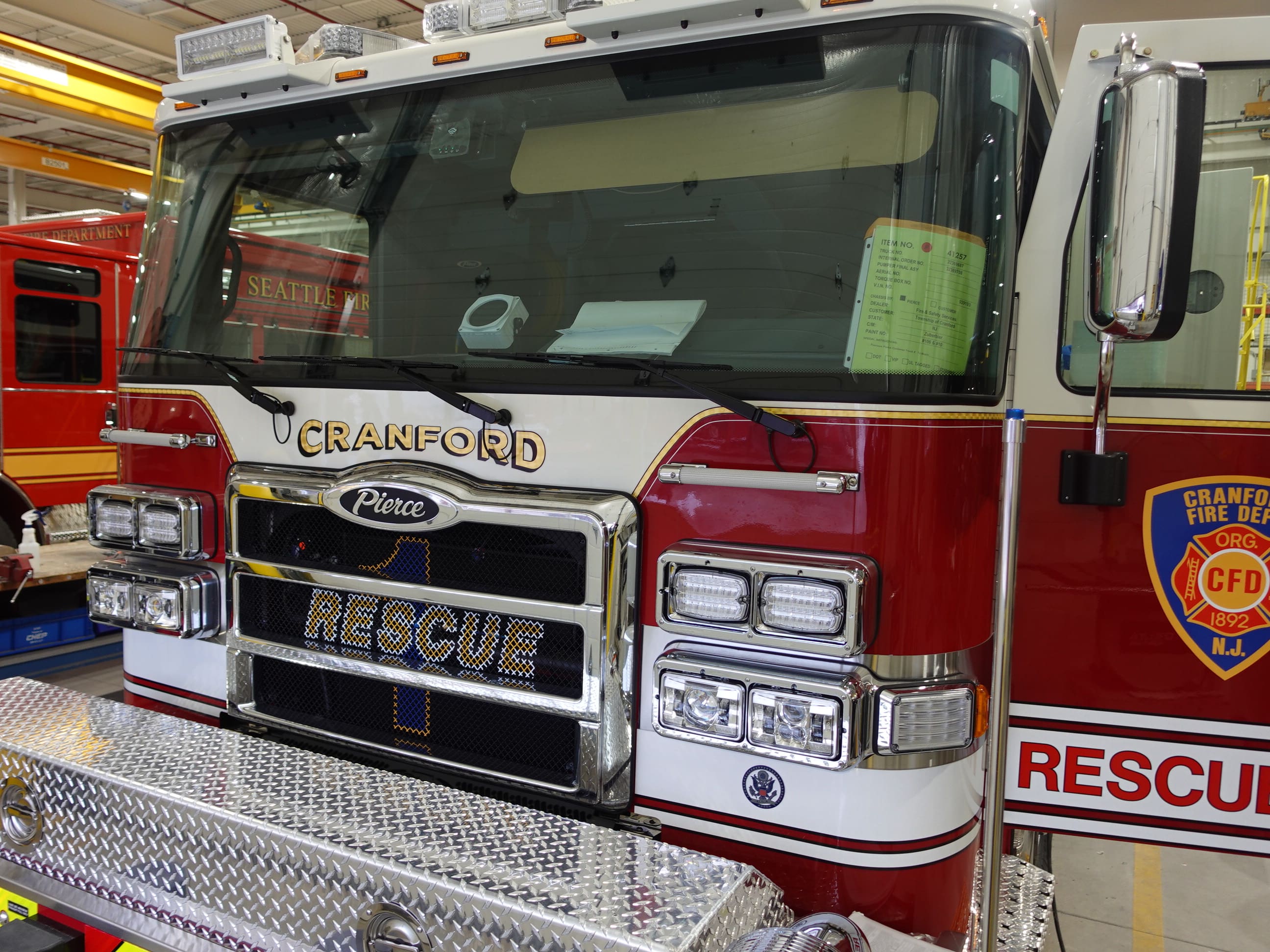

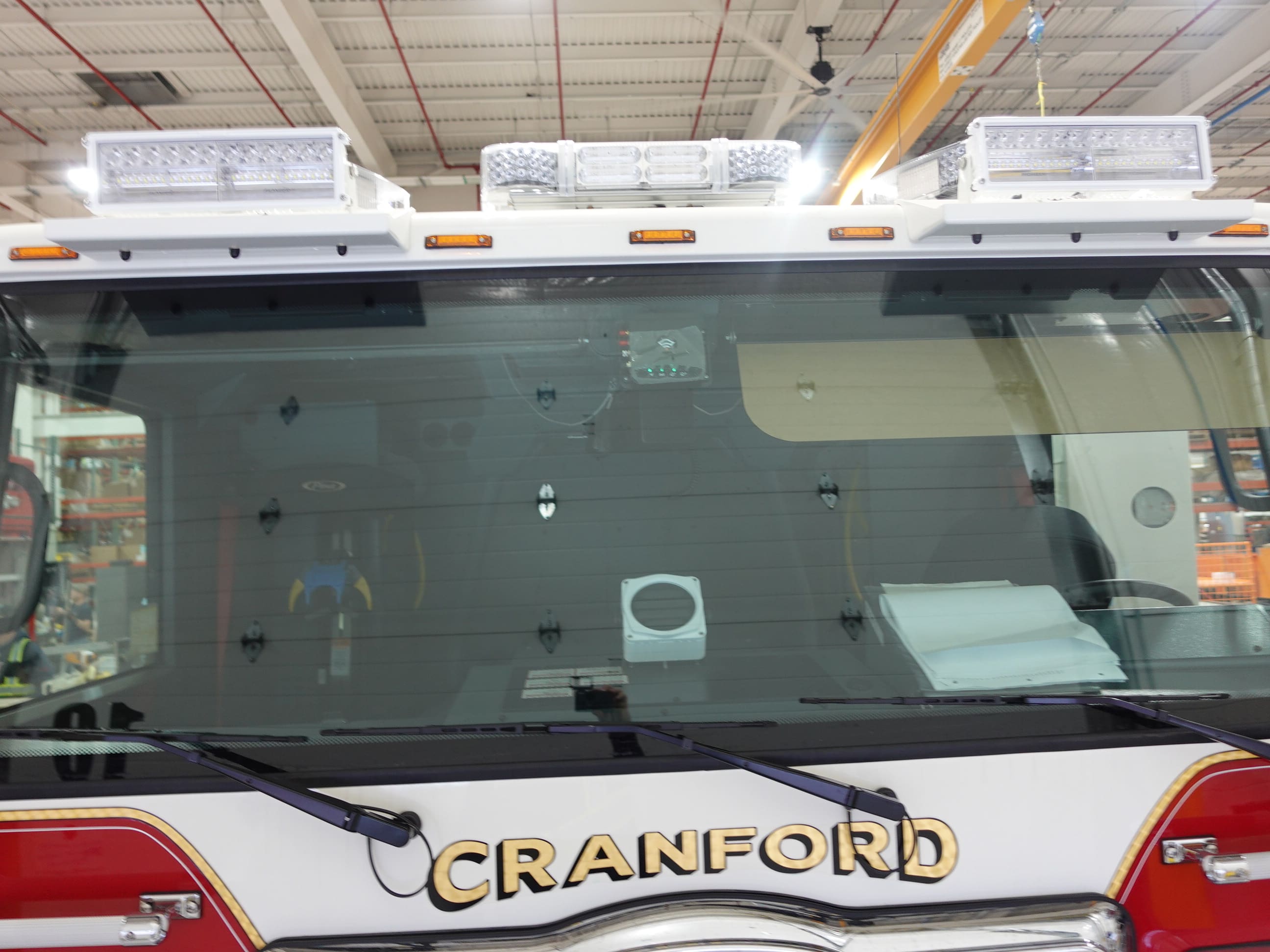

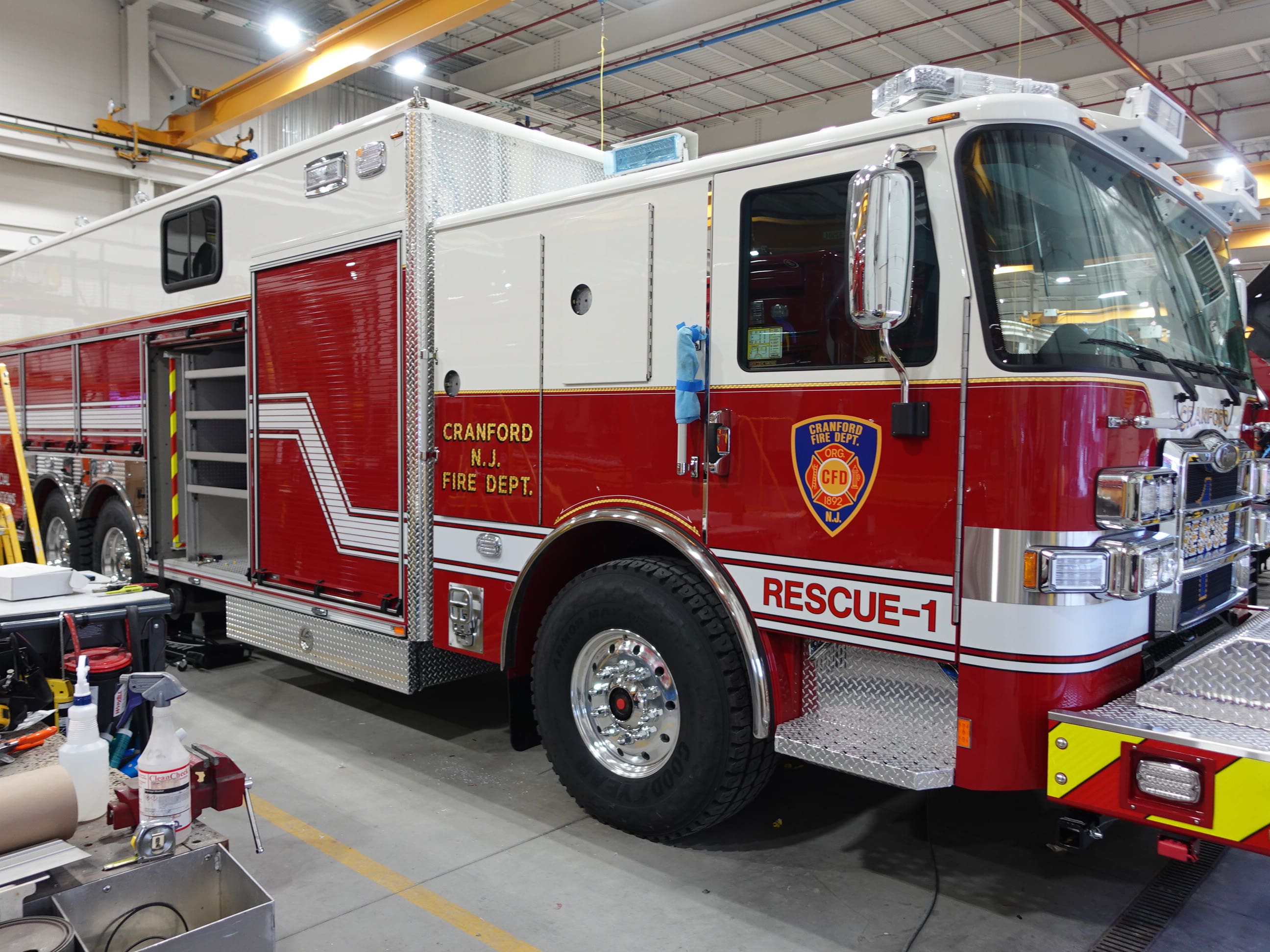

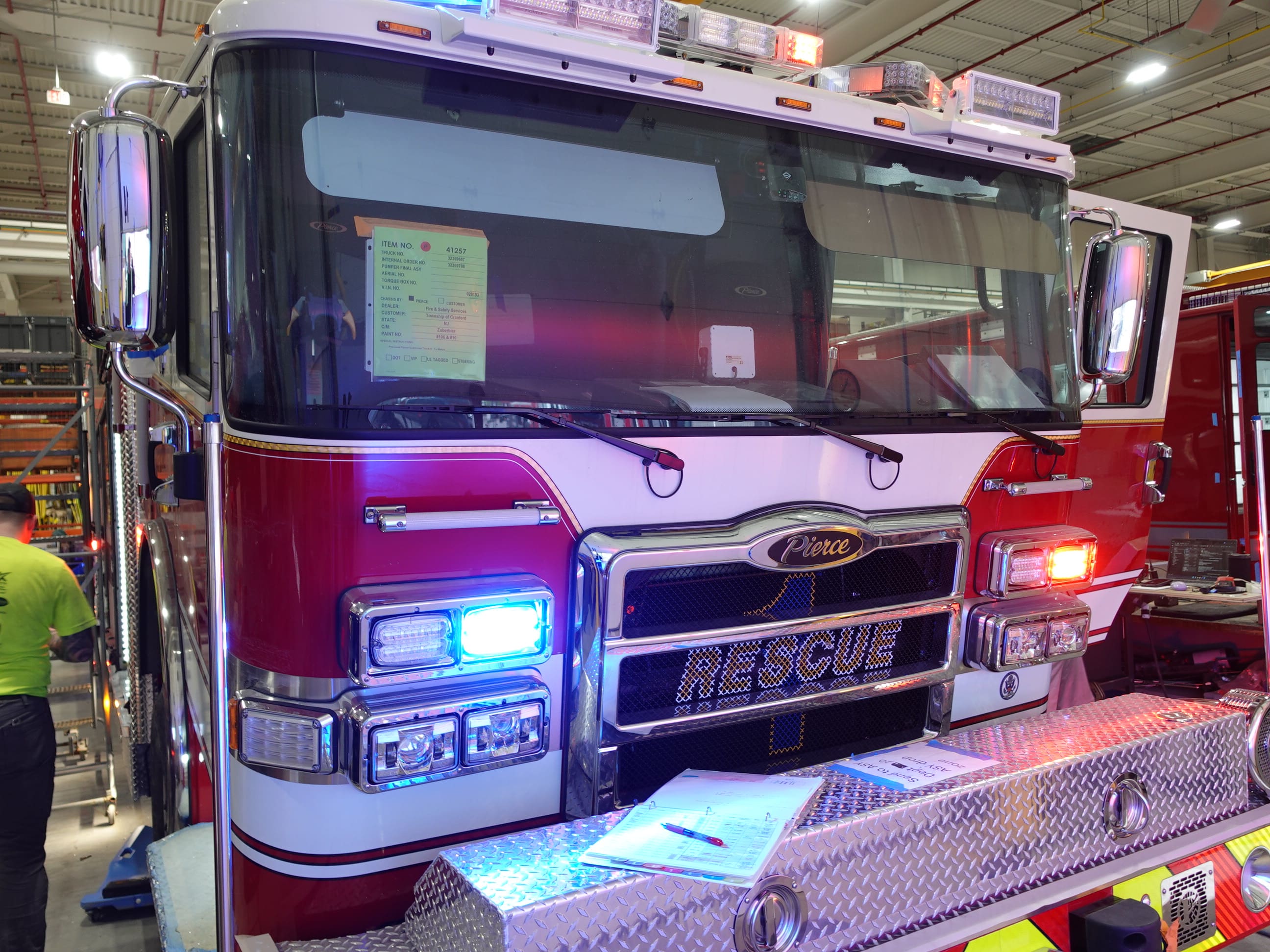

03-20-26

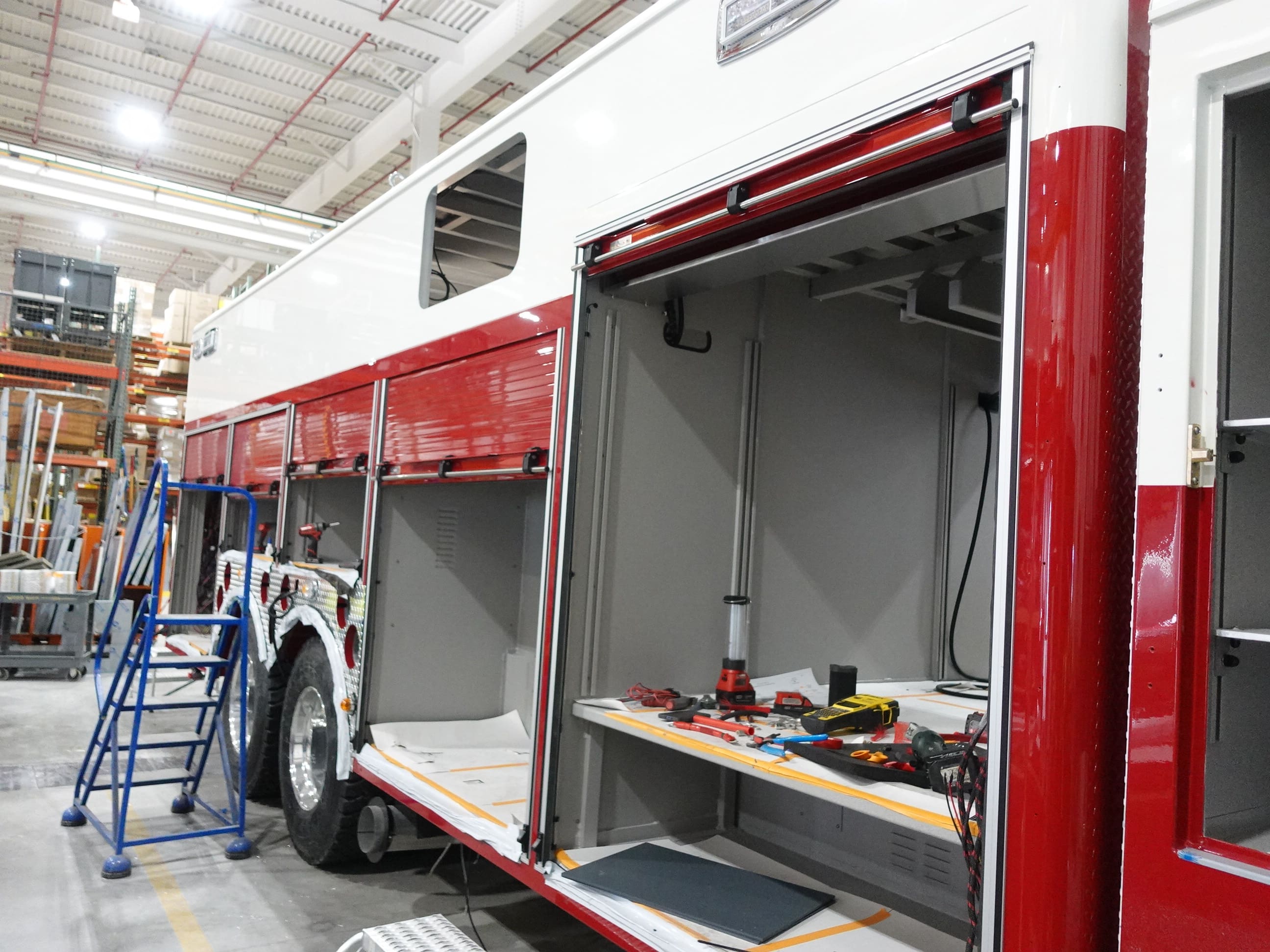

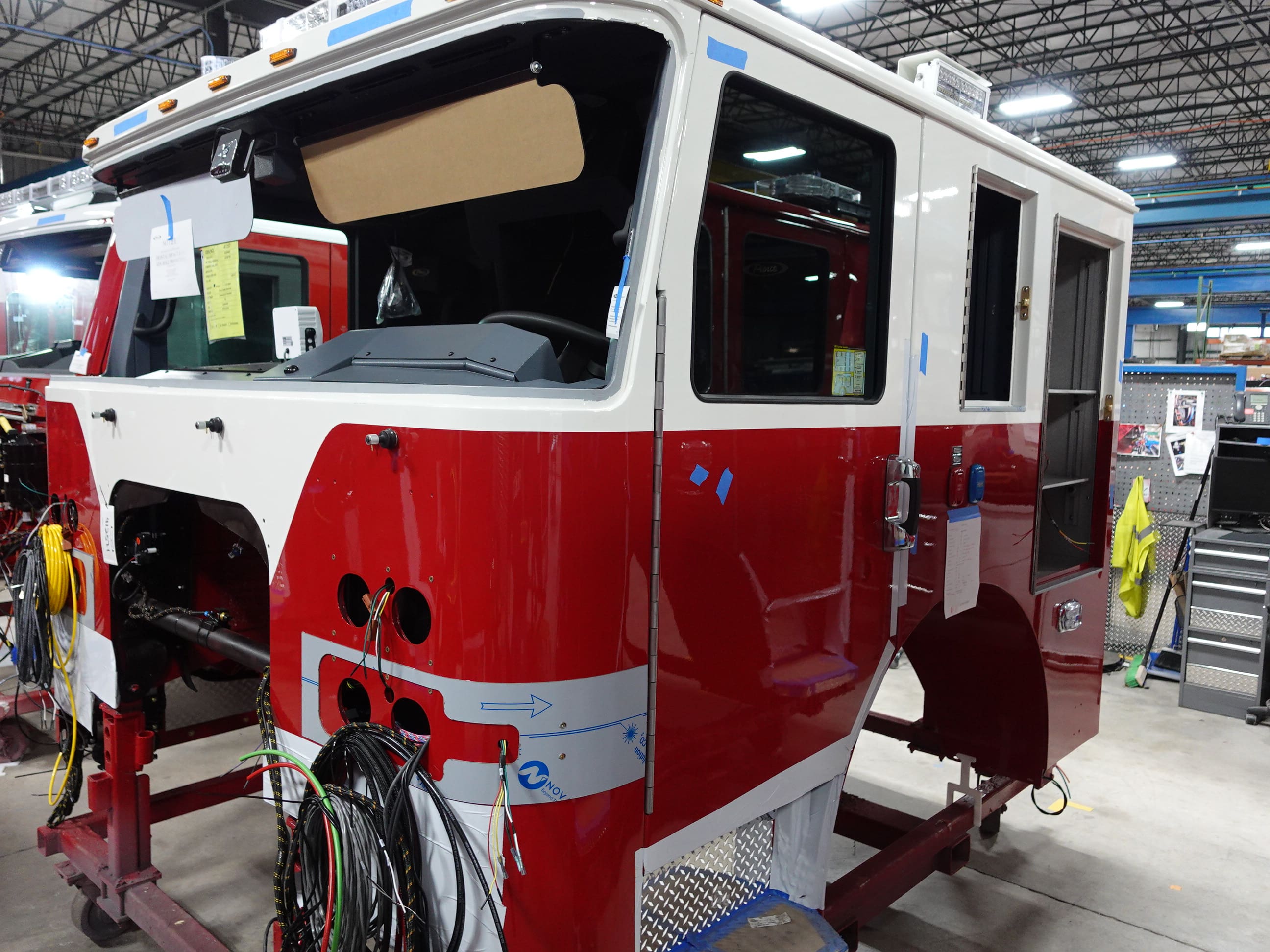

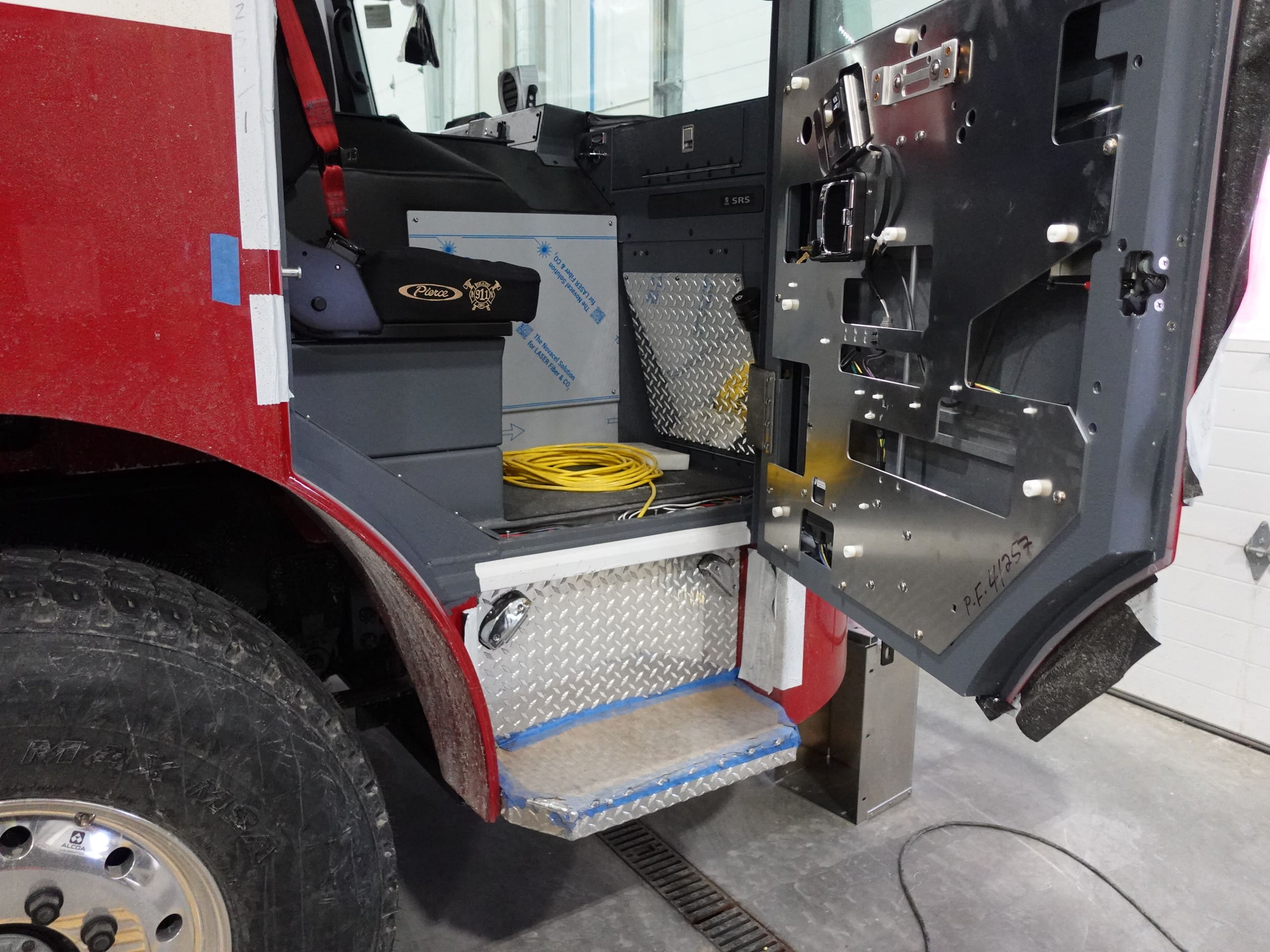

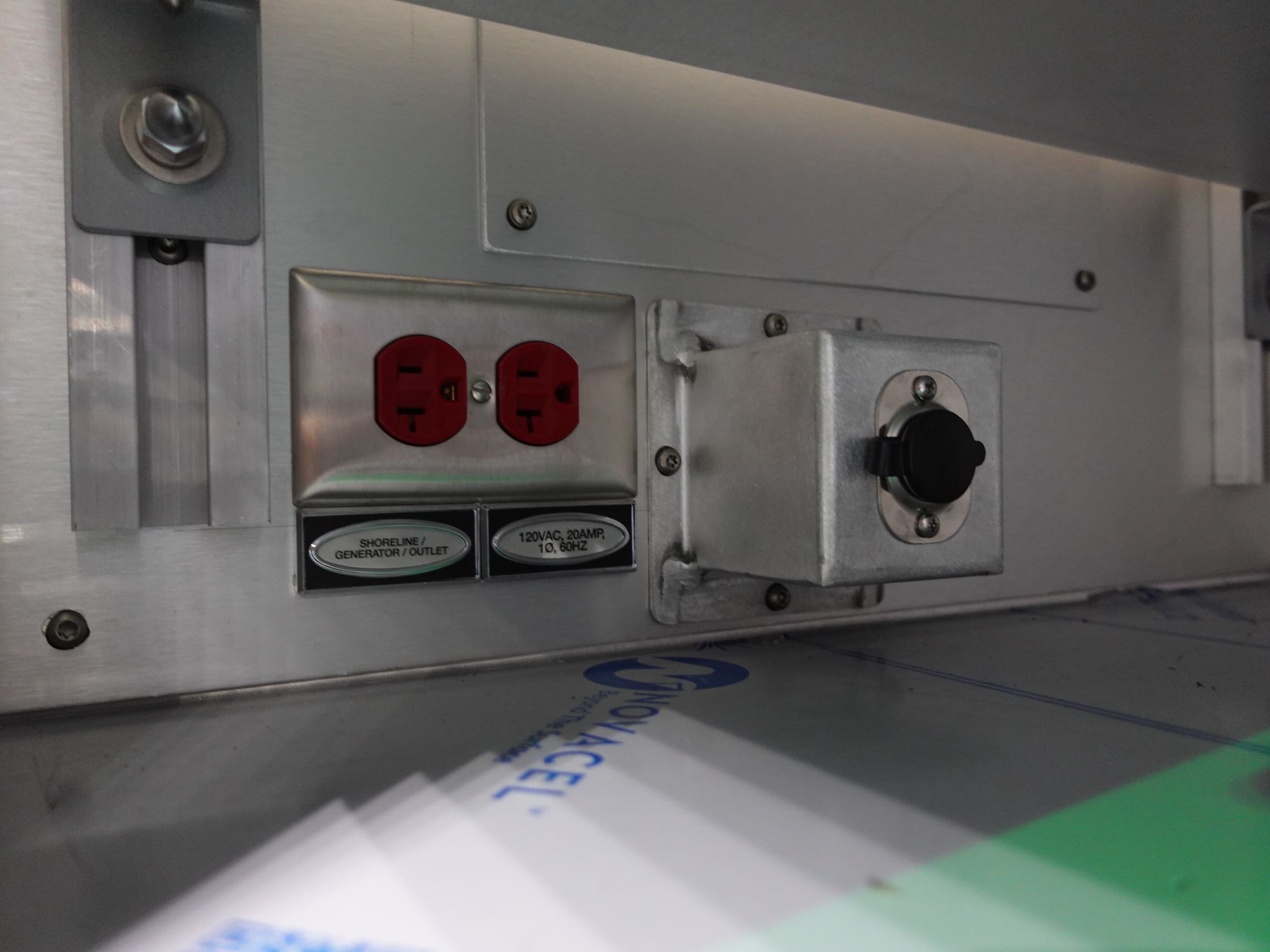

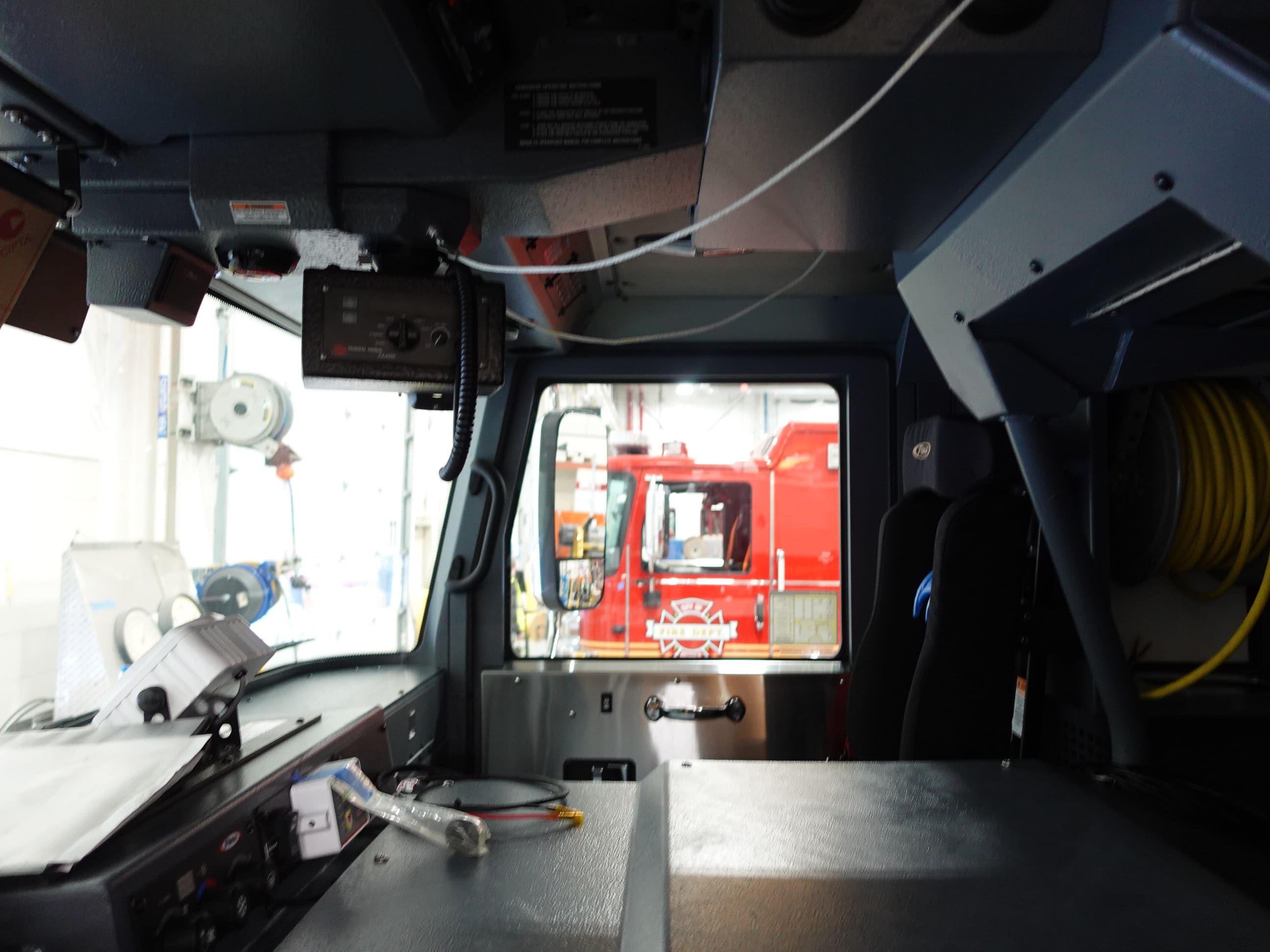

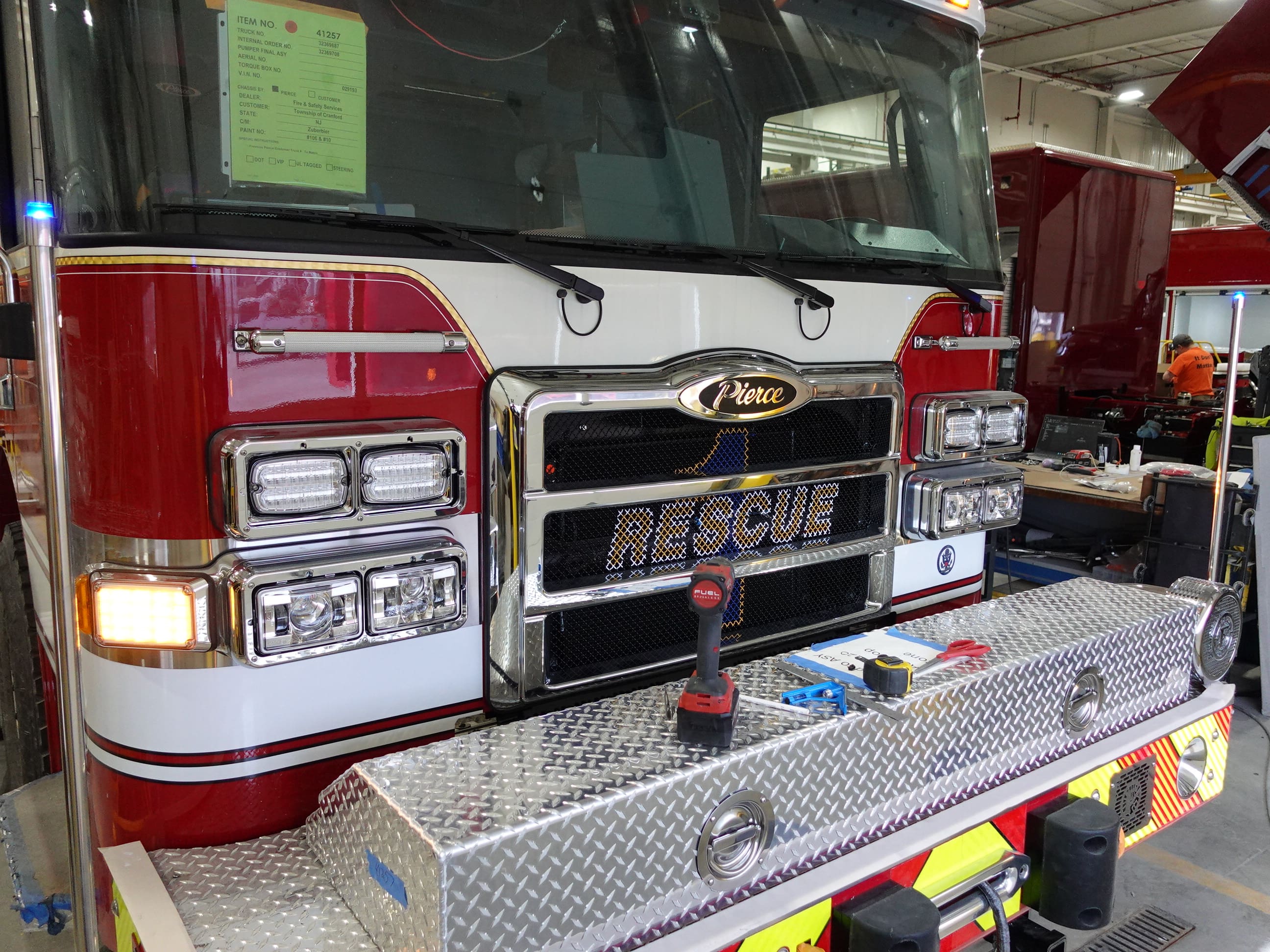

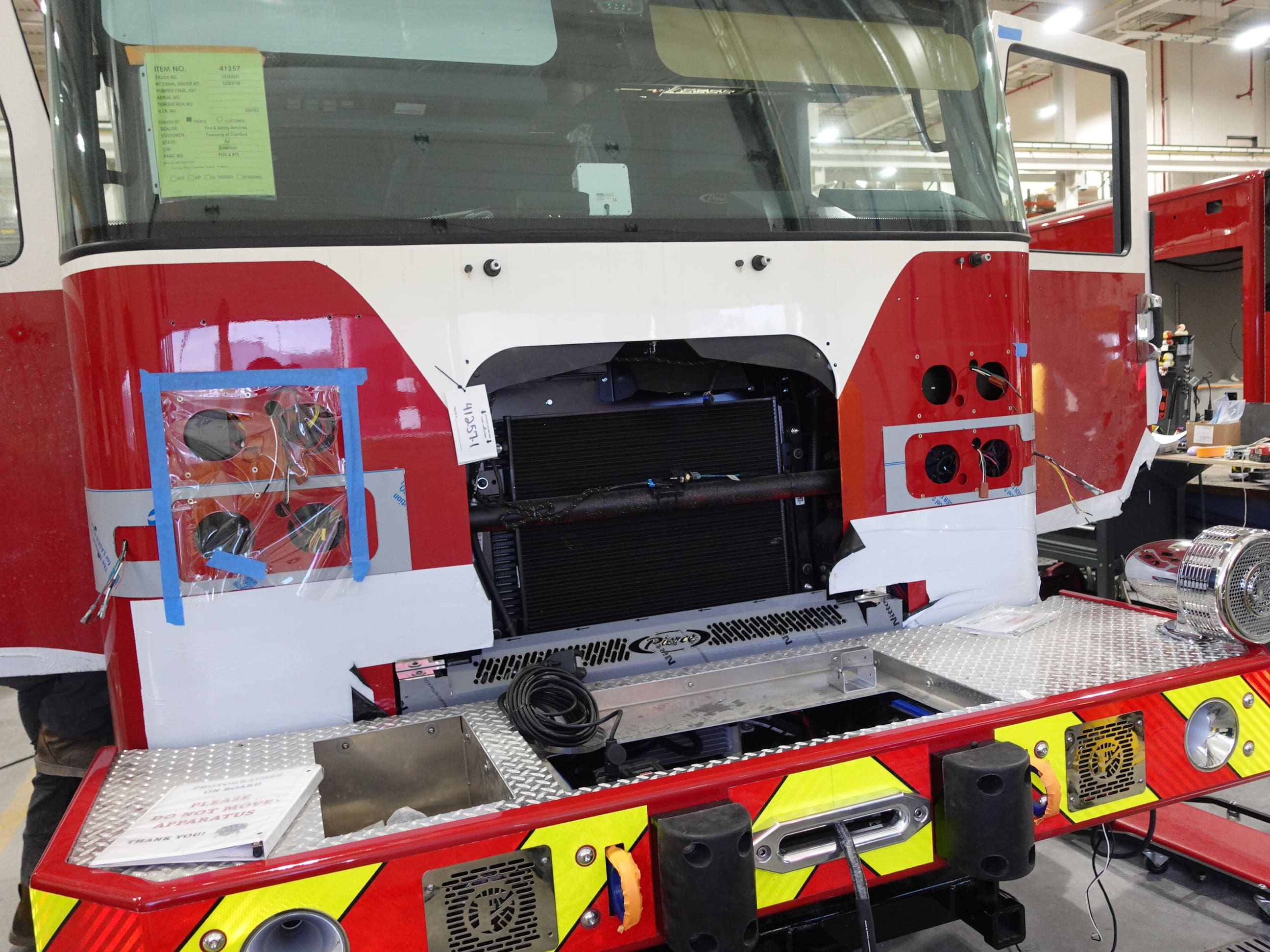

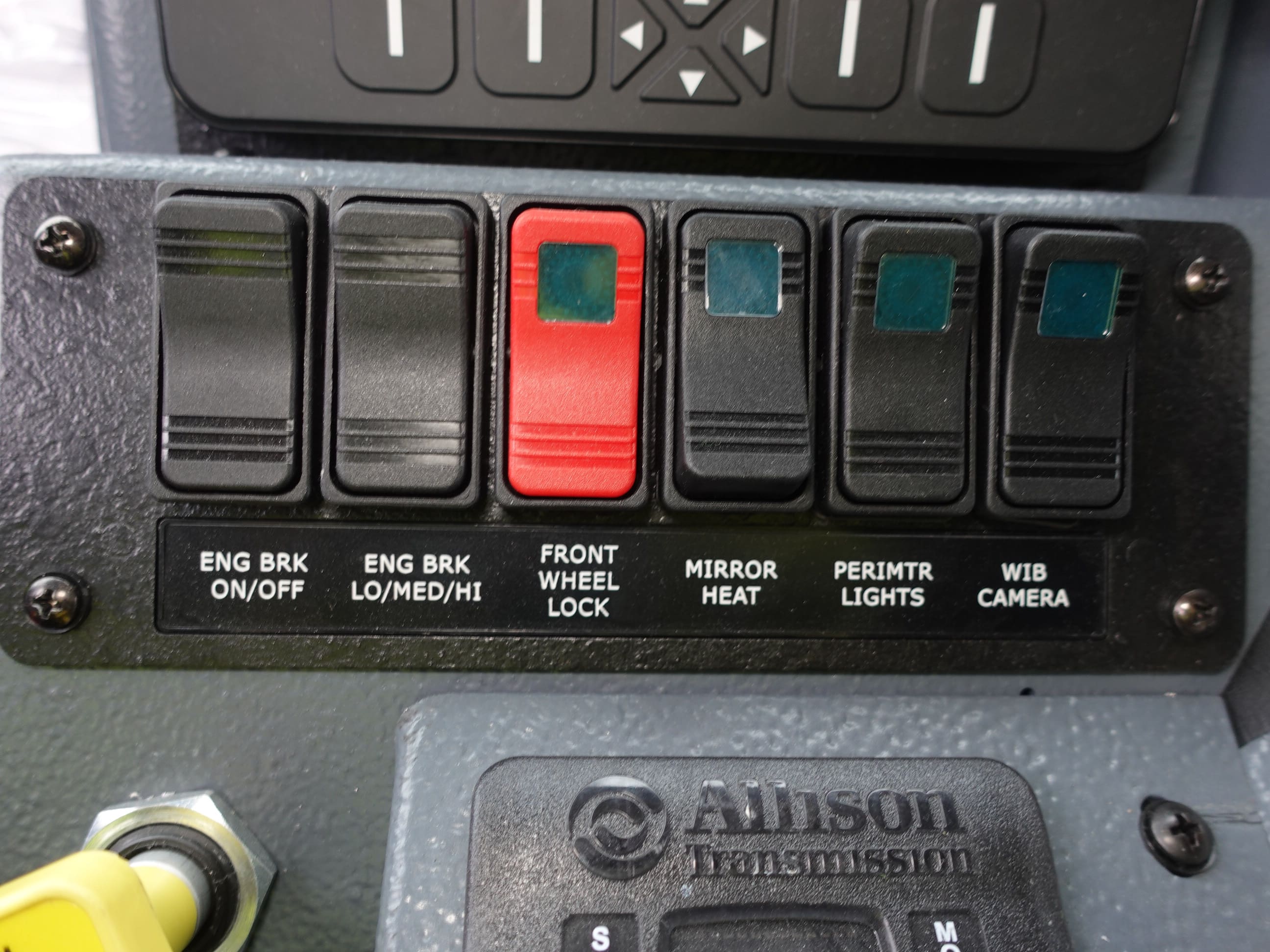

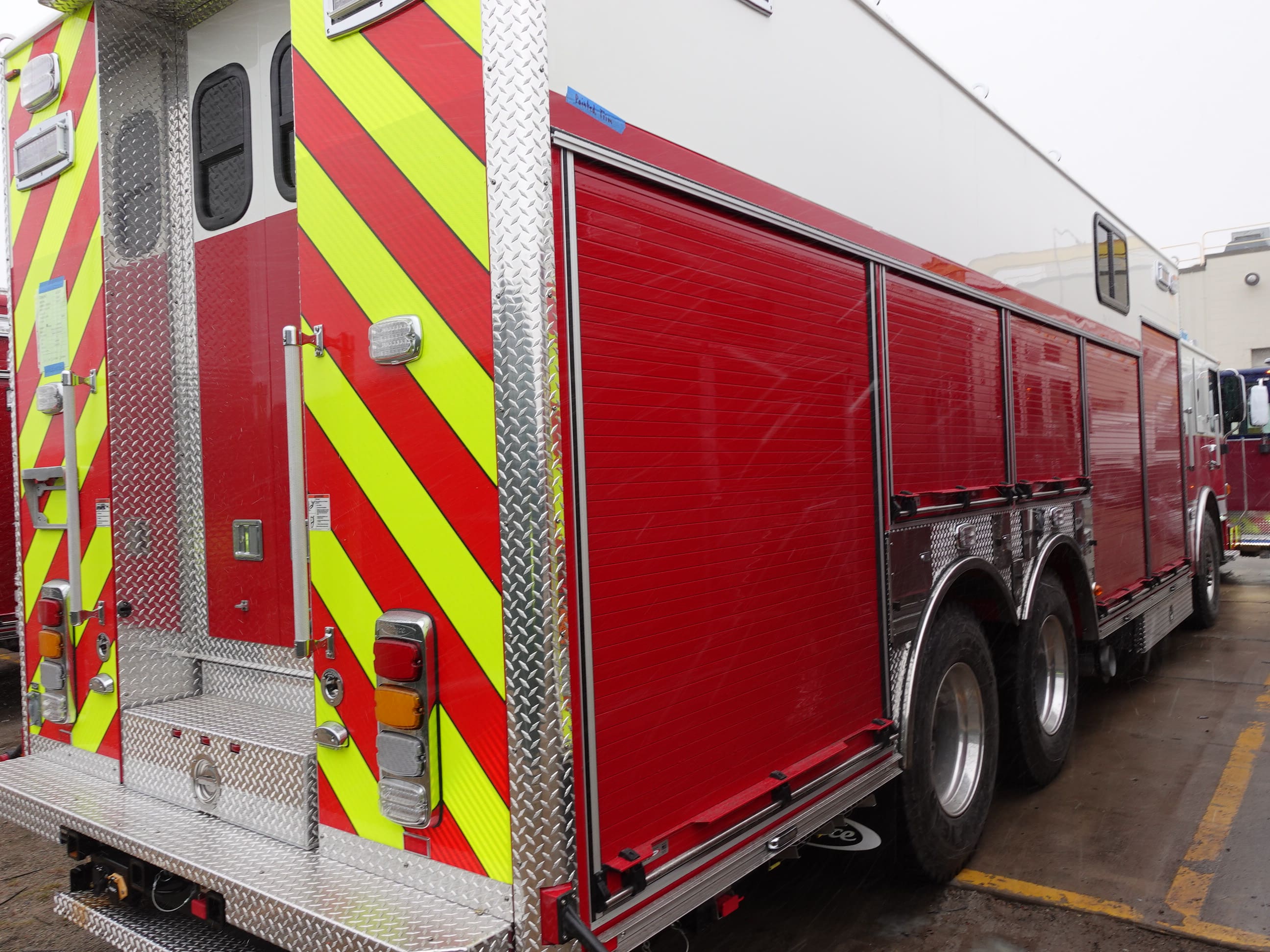

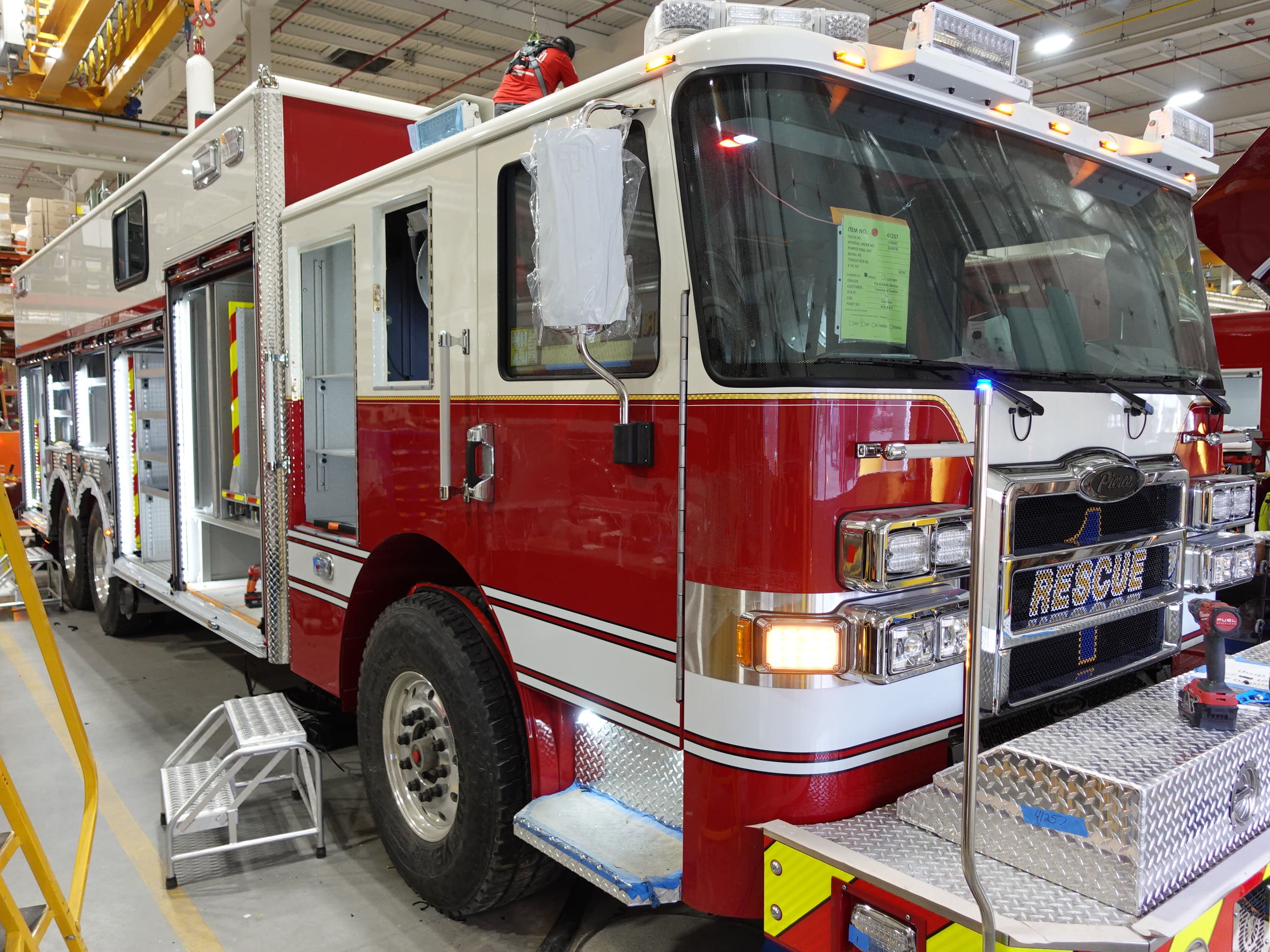

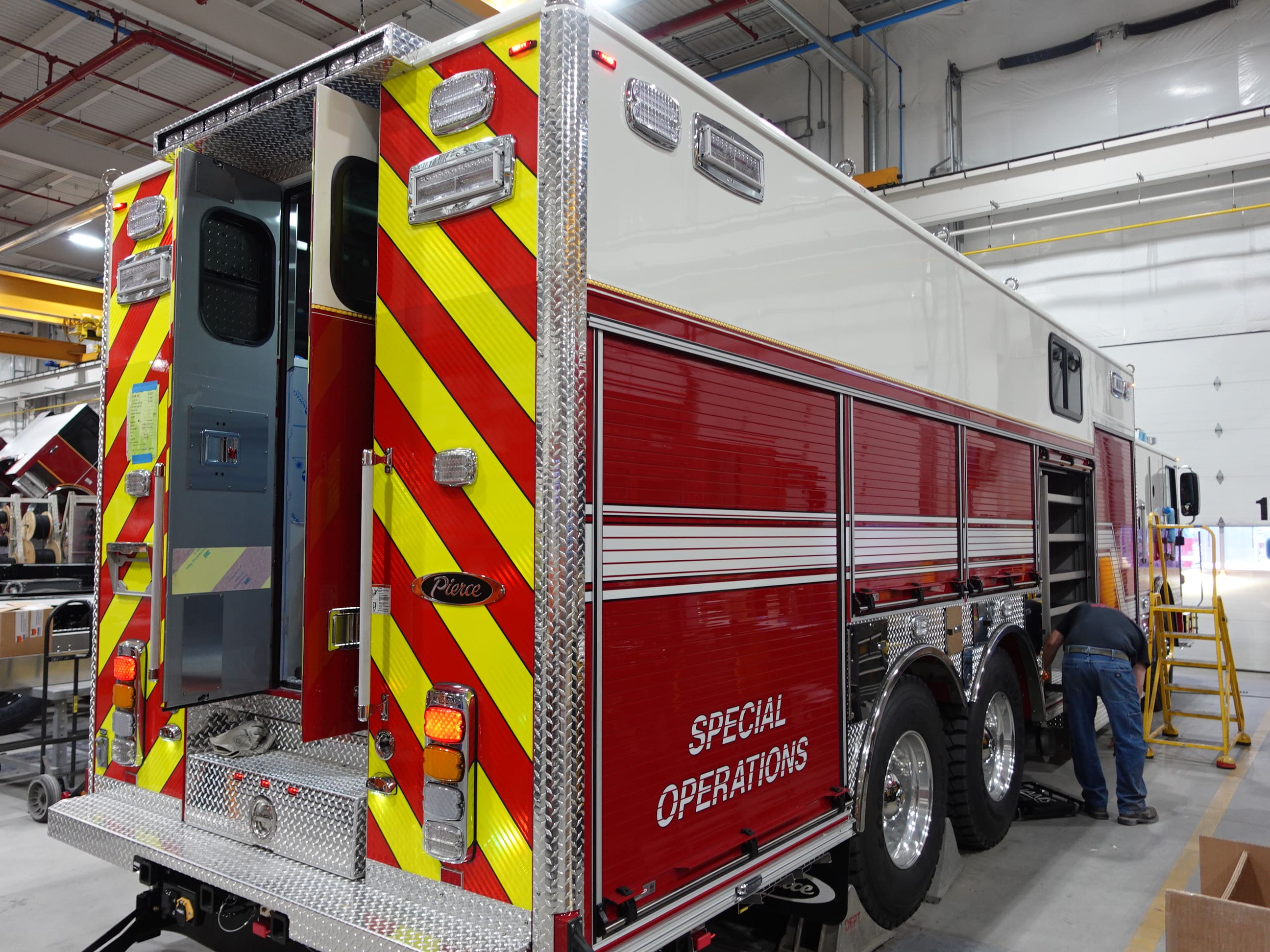

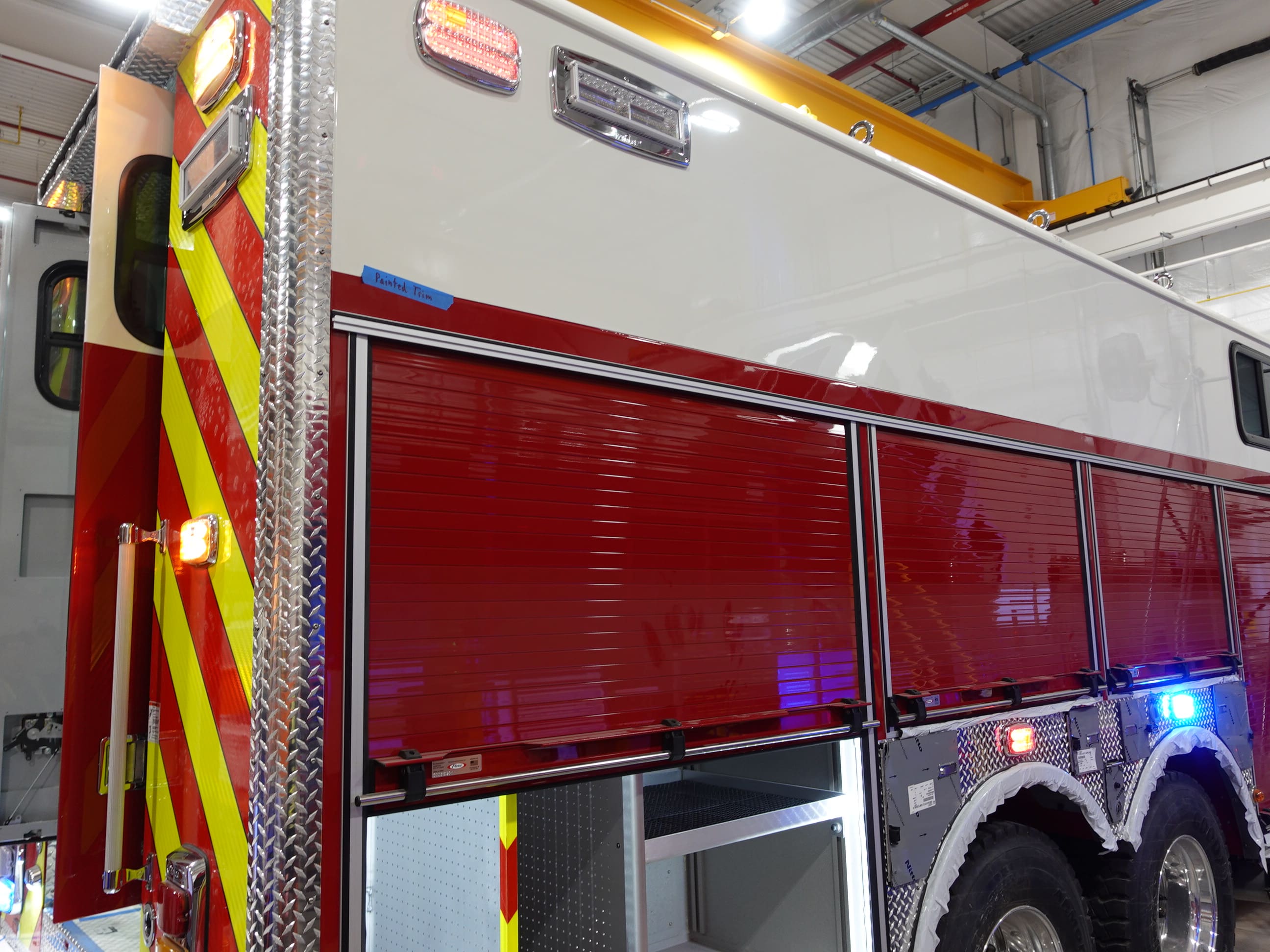

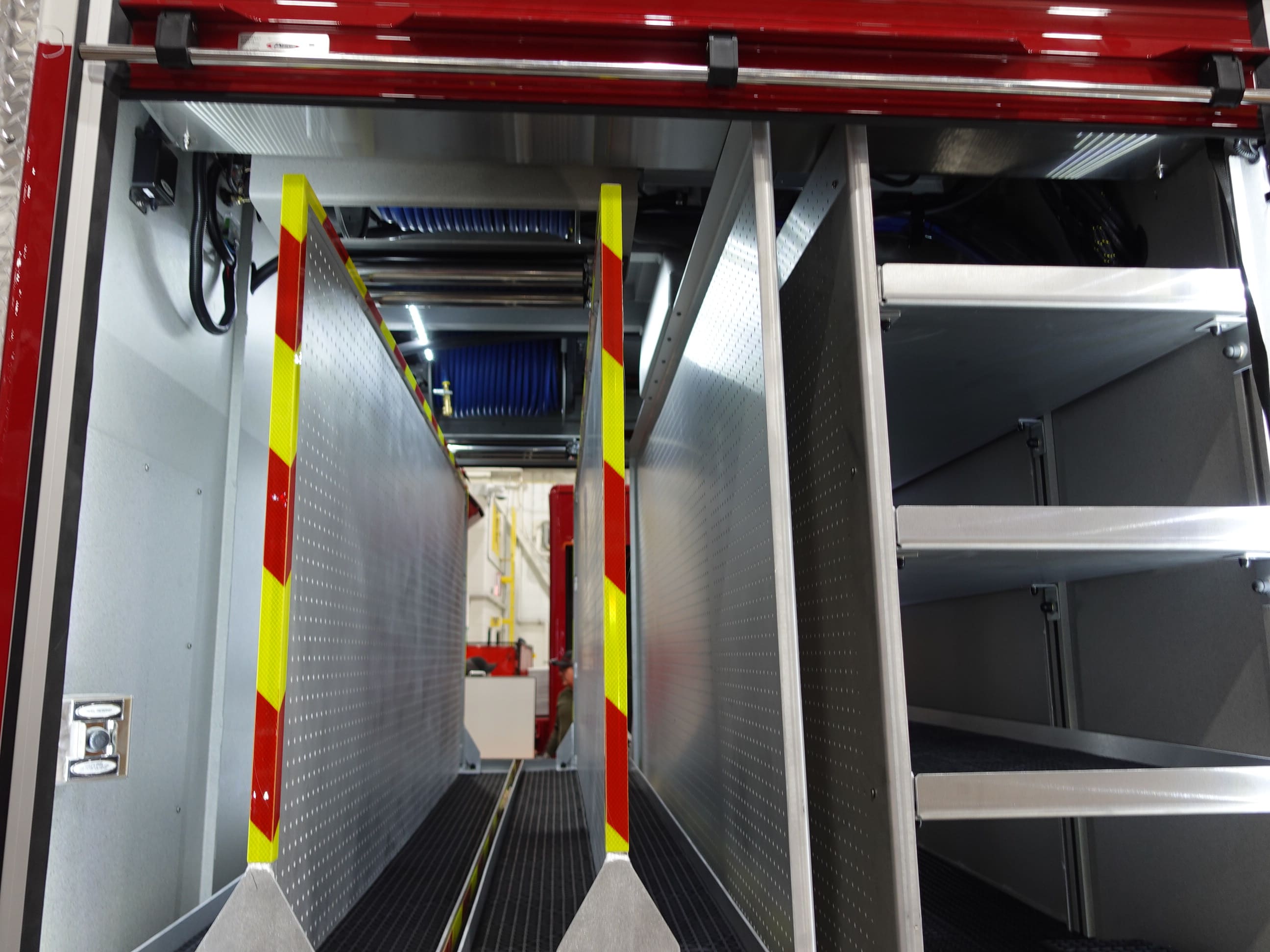

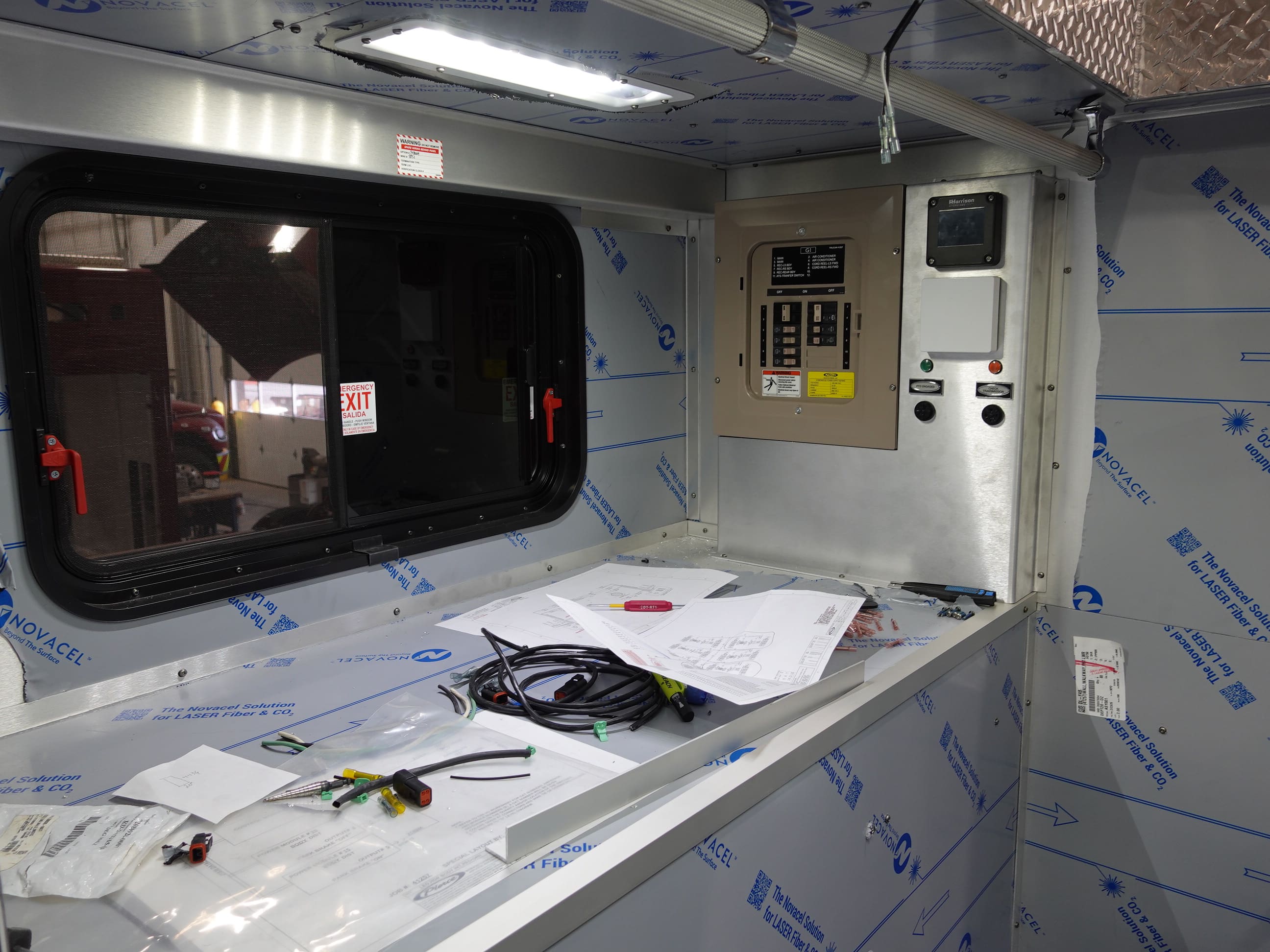

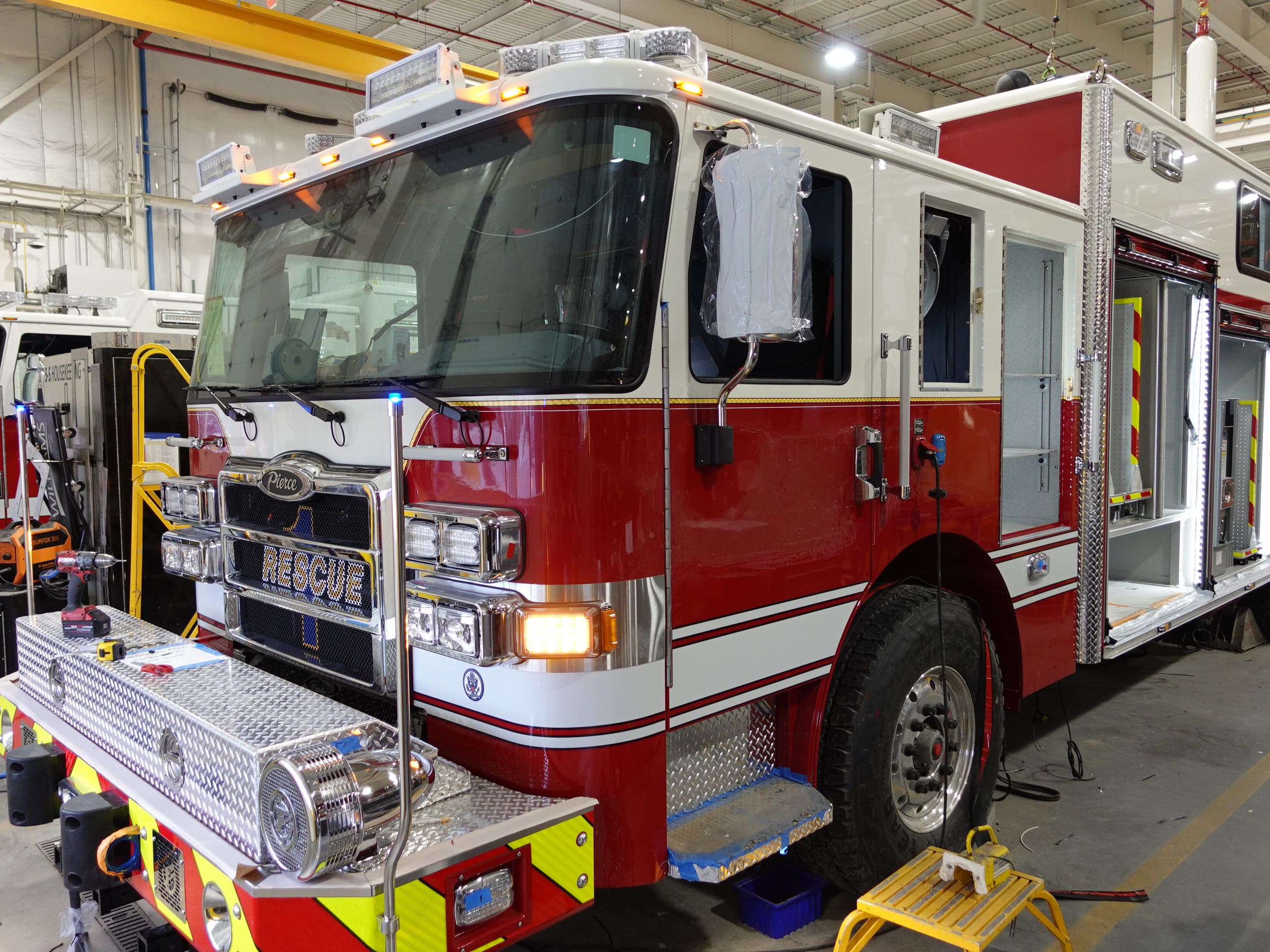

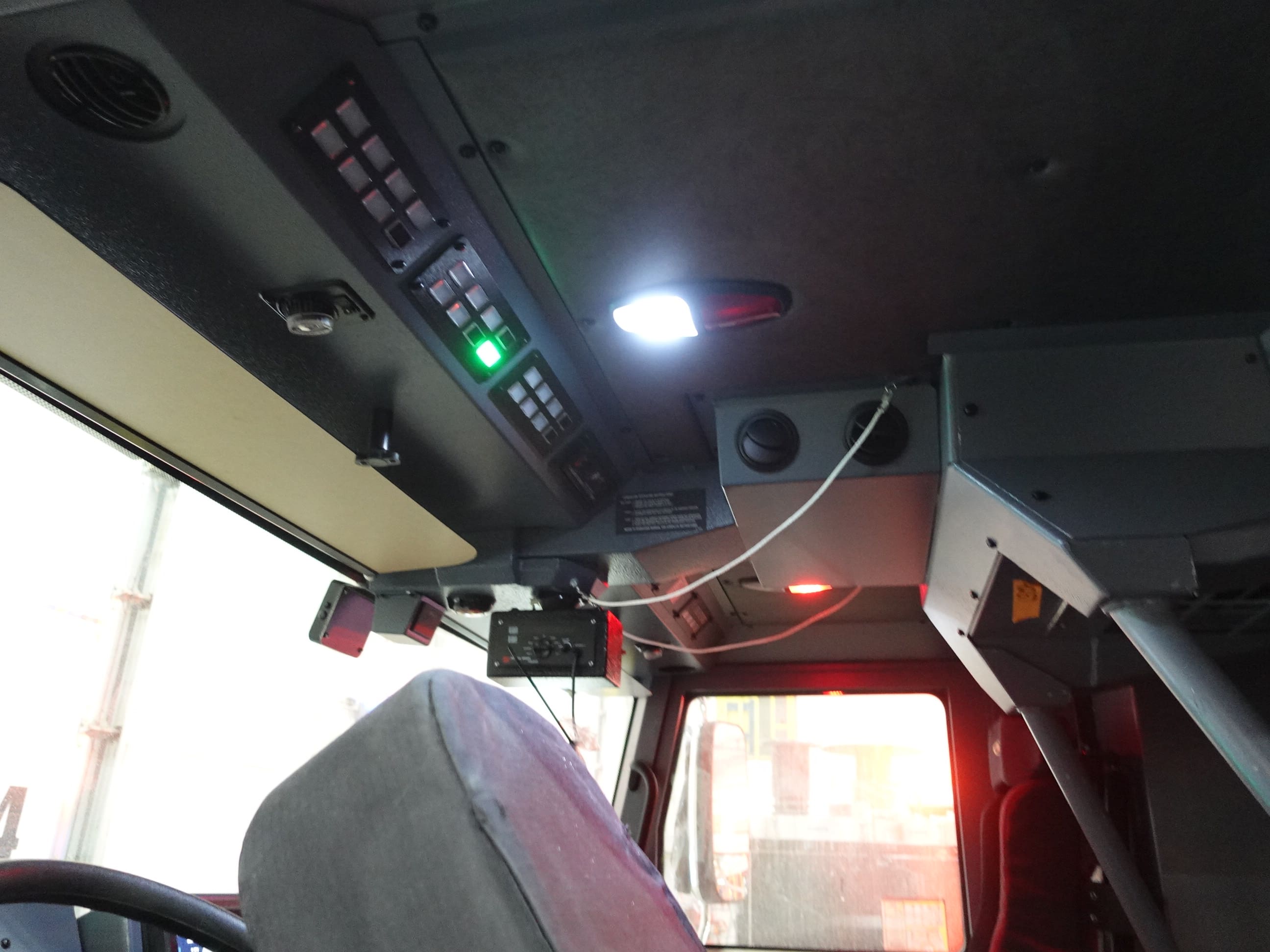

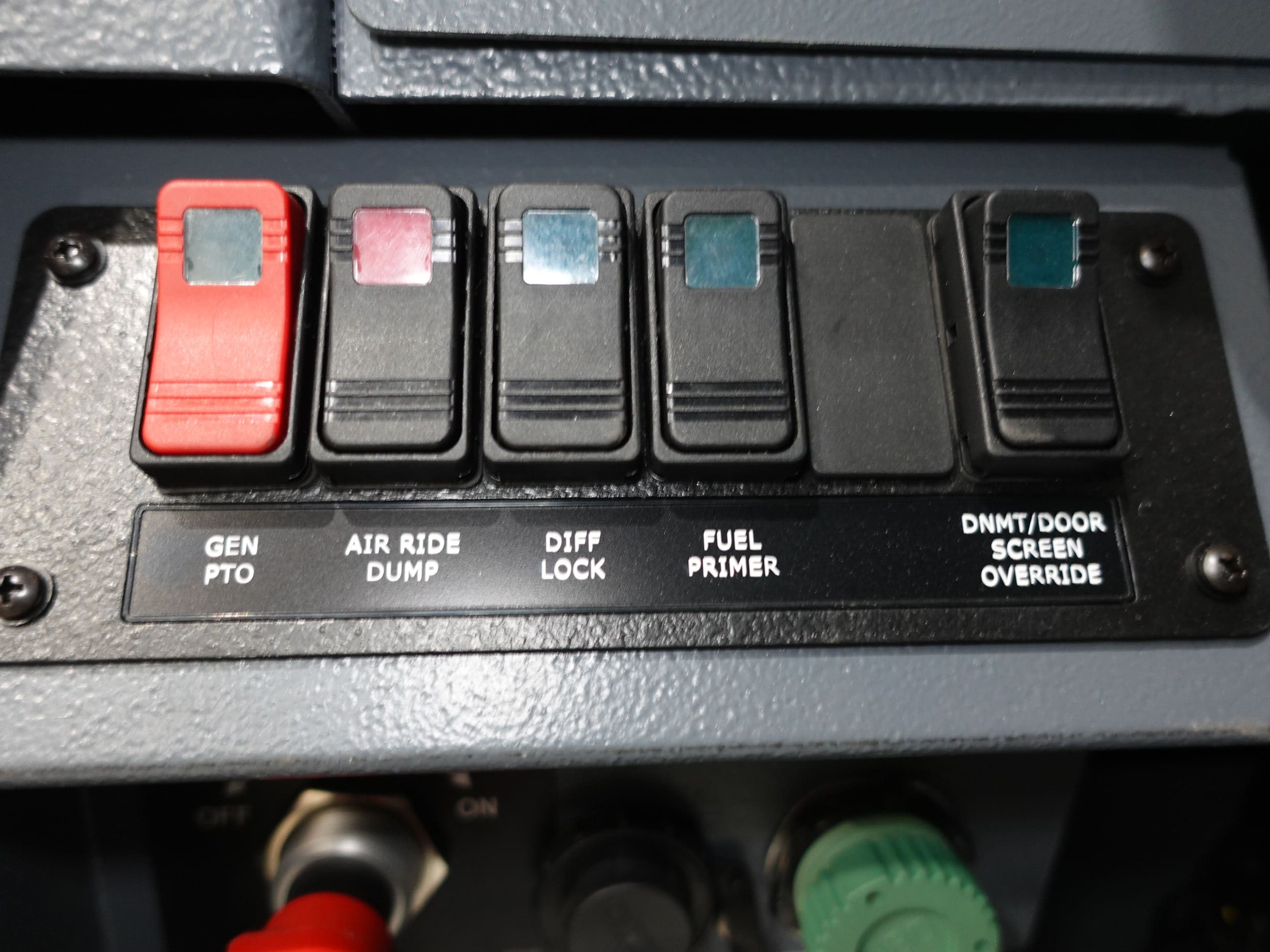

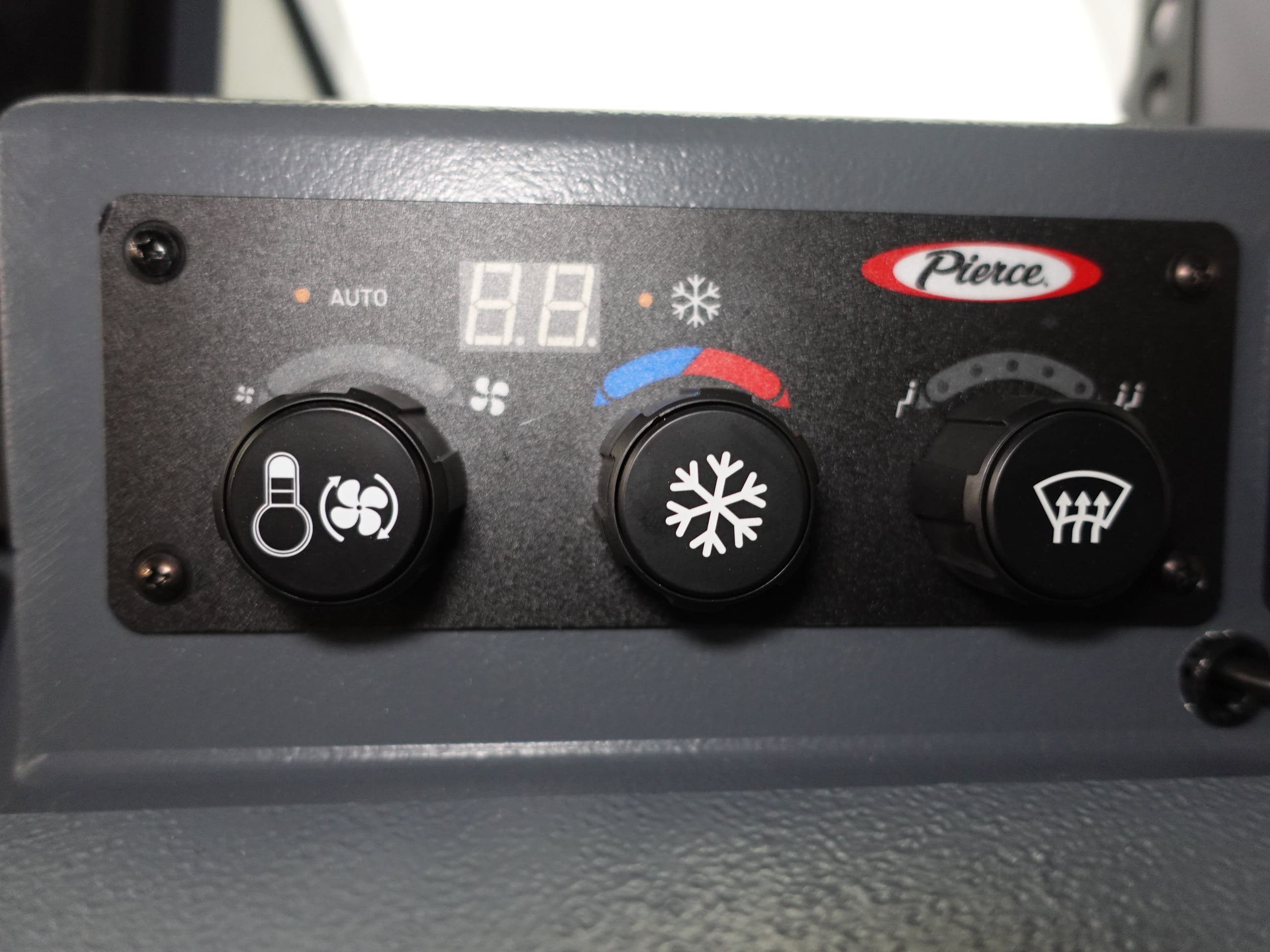

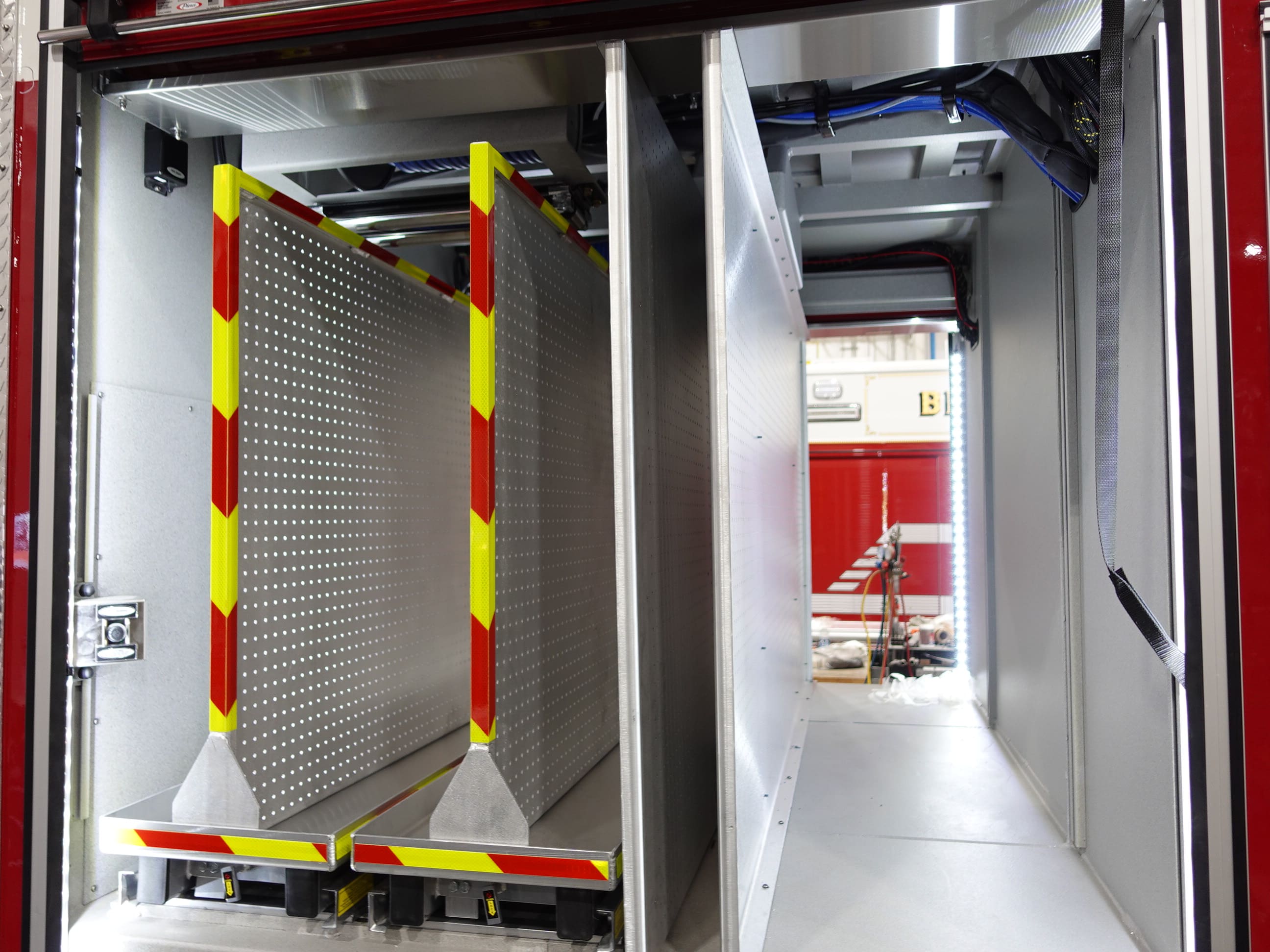

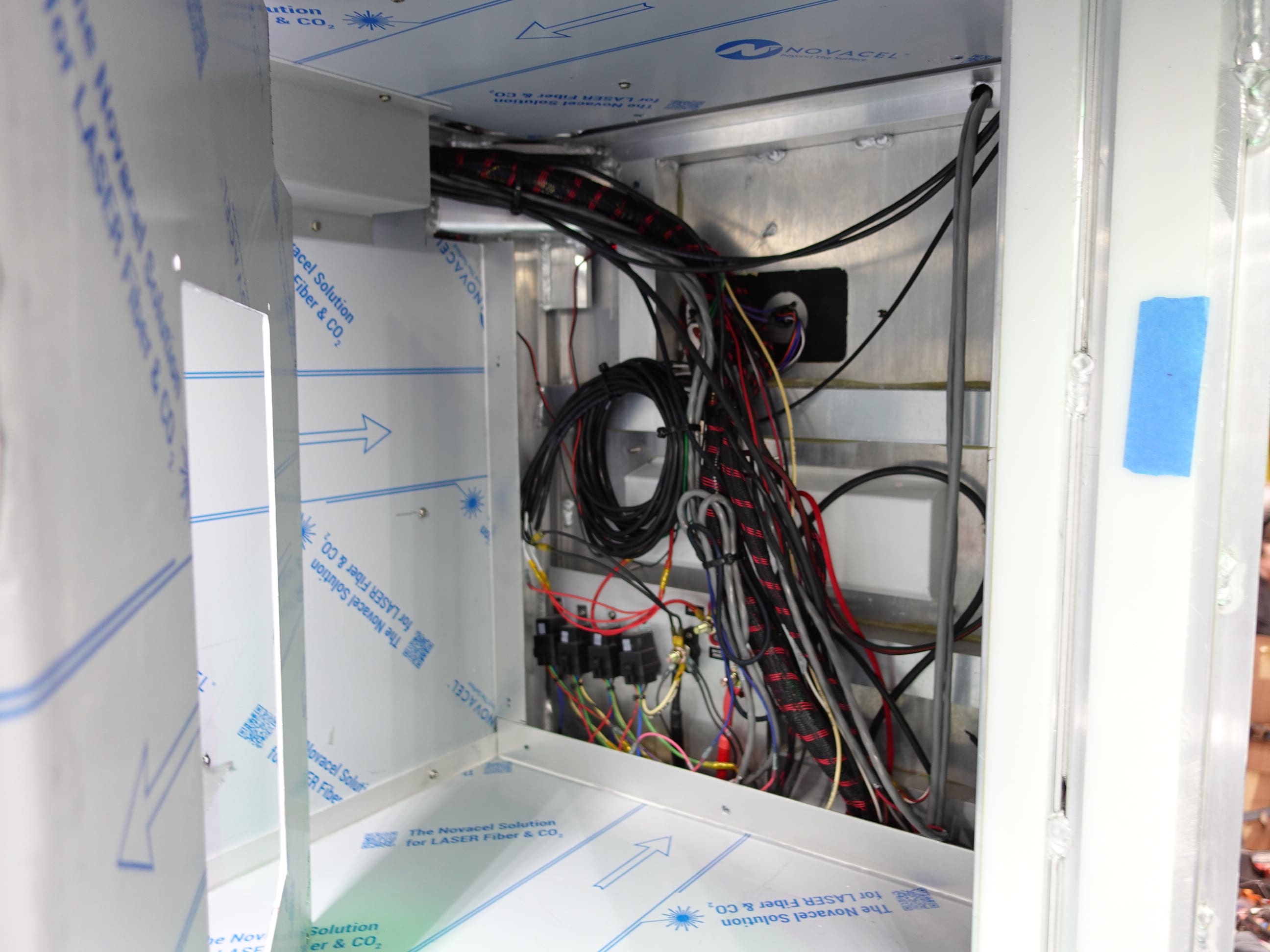

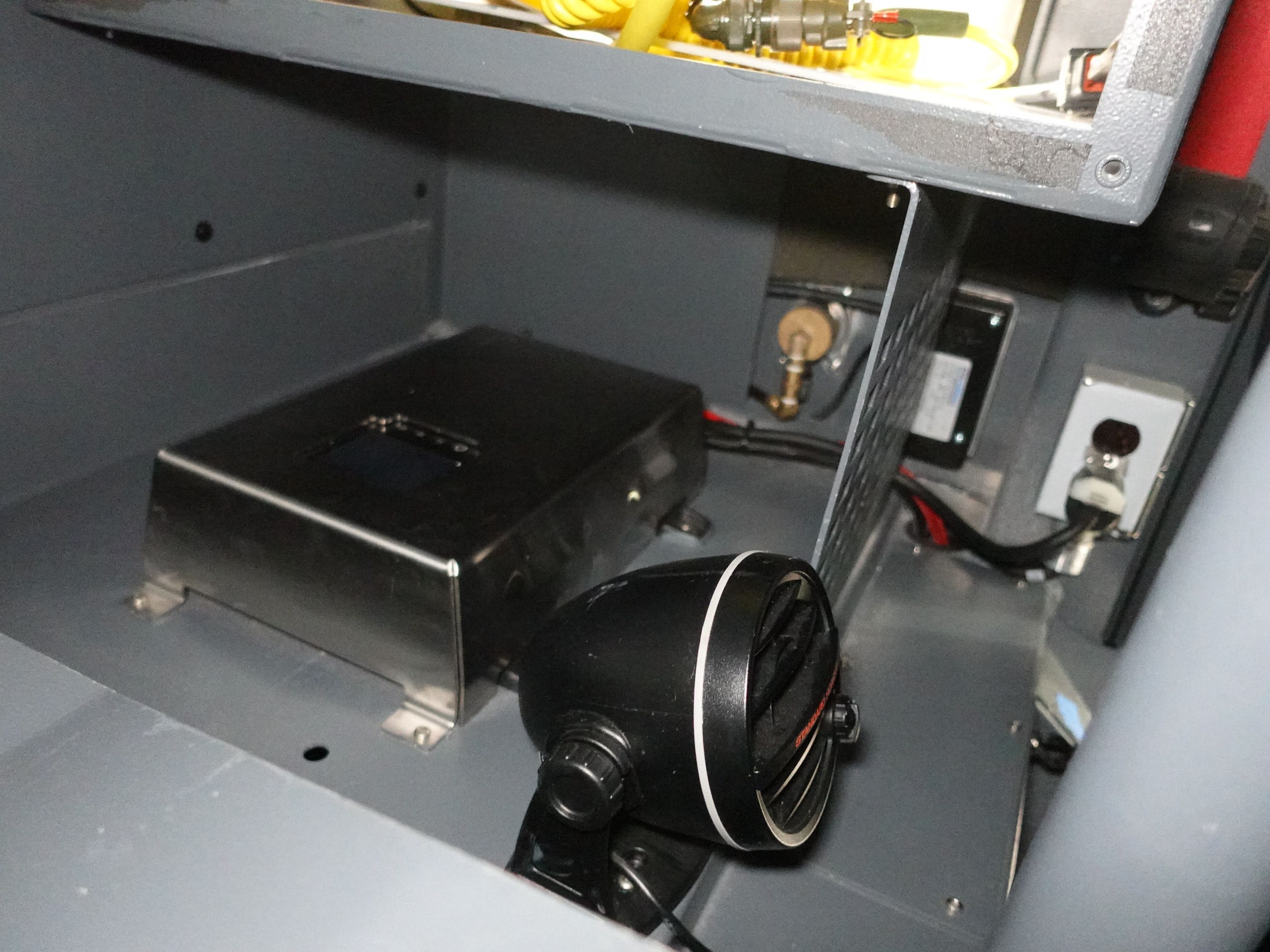

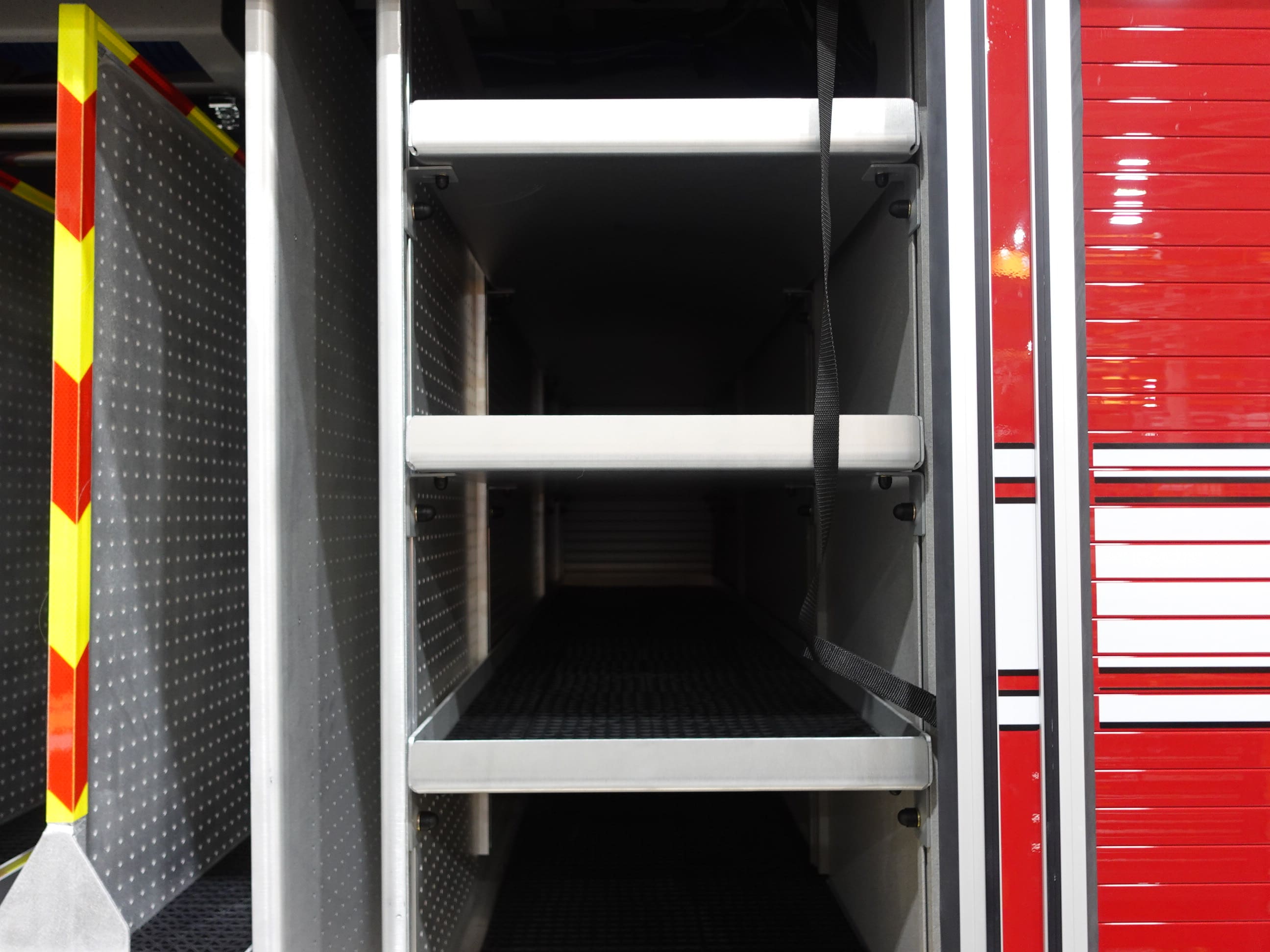

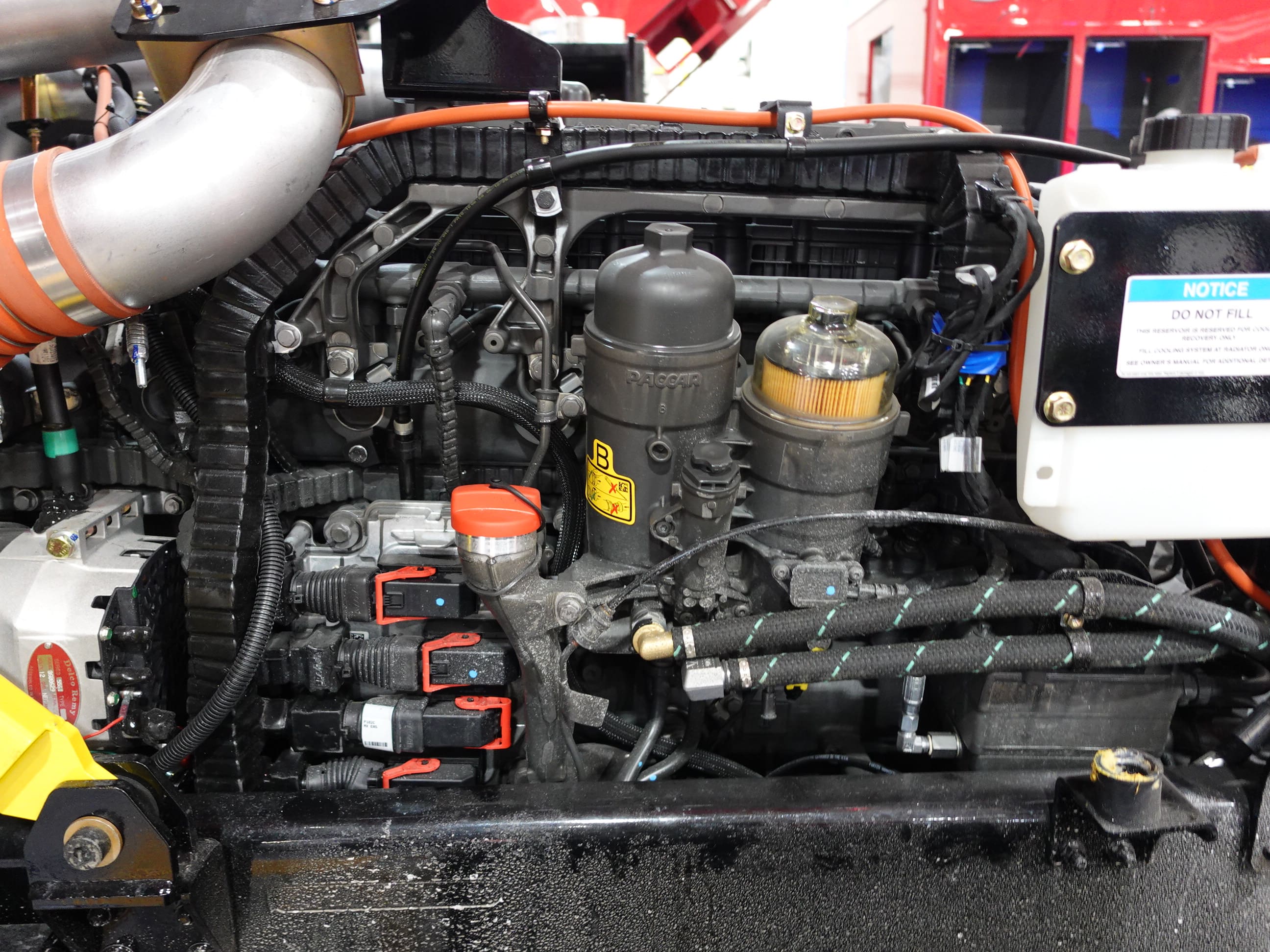

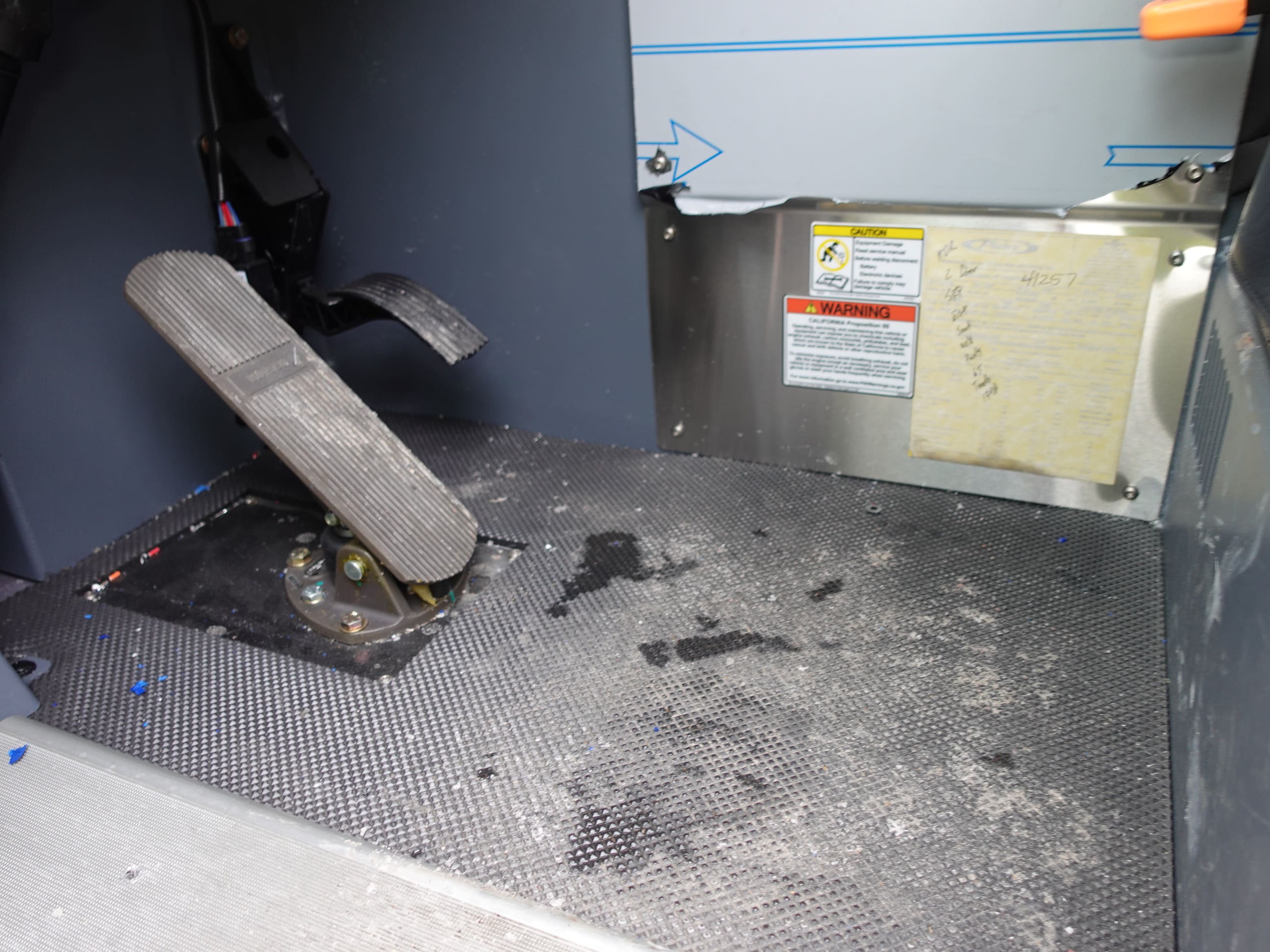

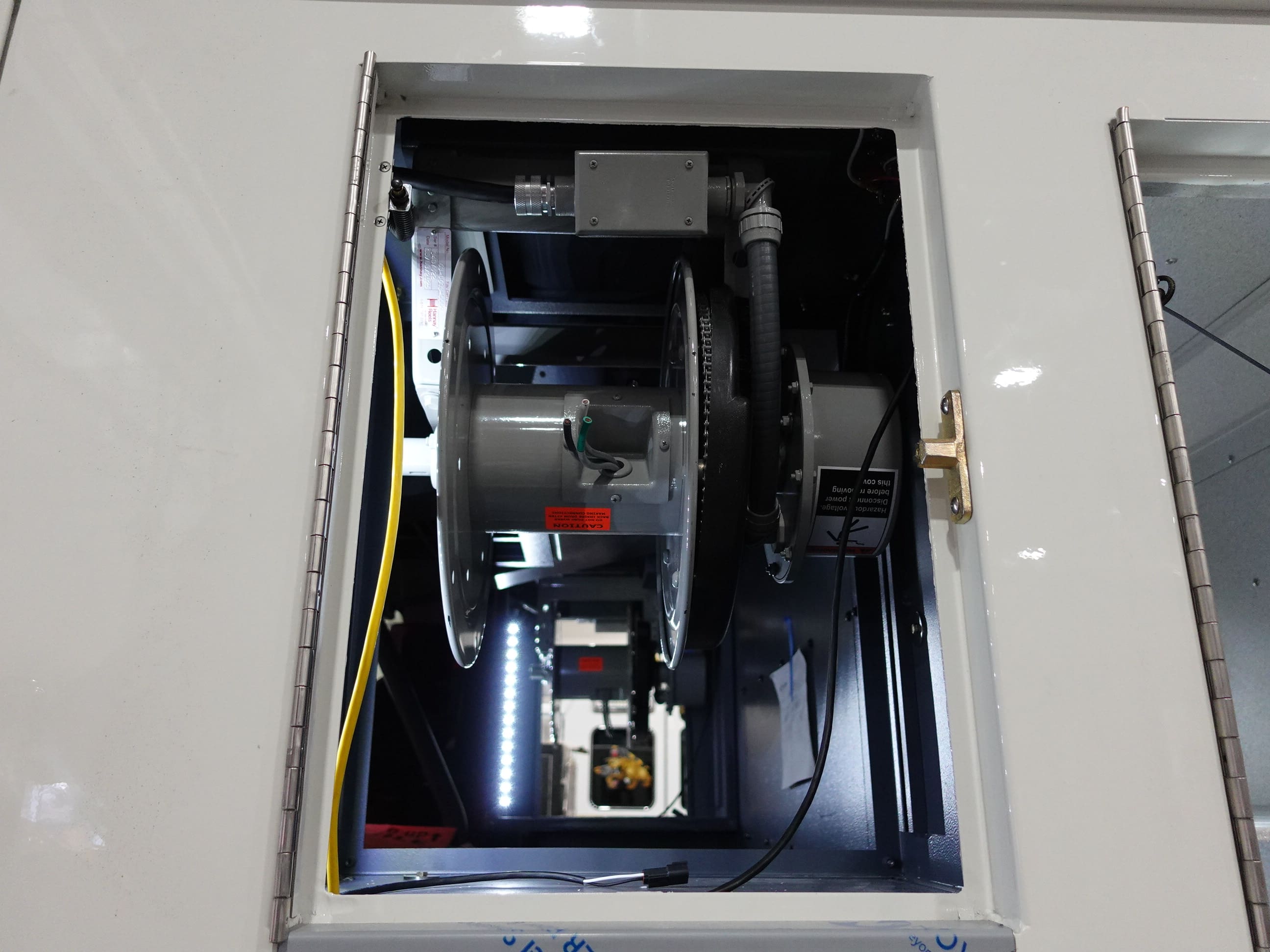

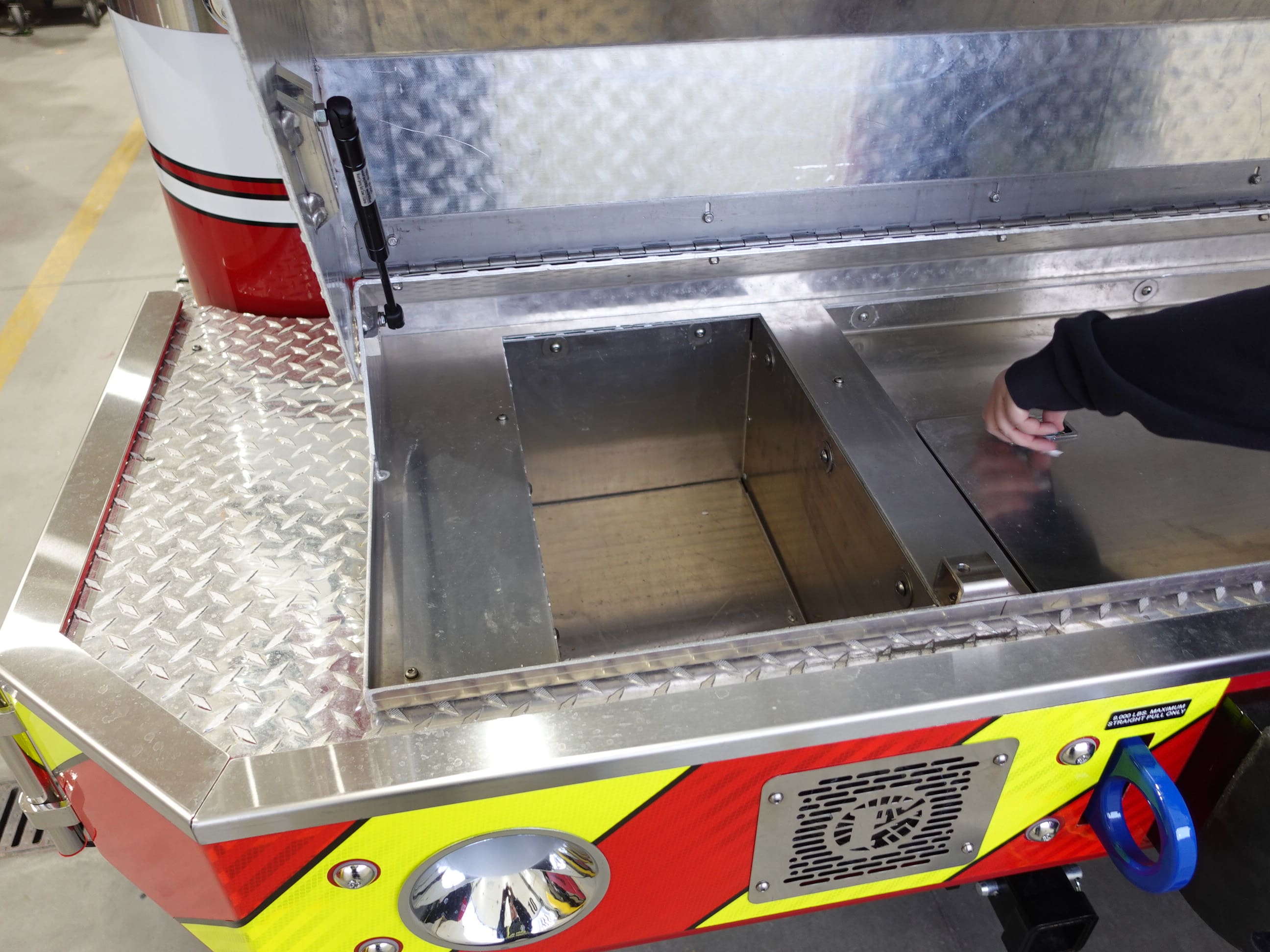

In this report, the apparatus completed testing and

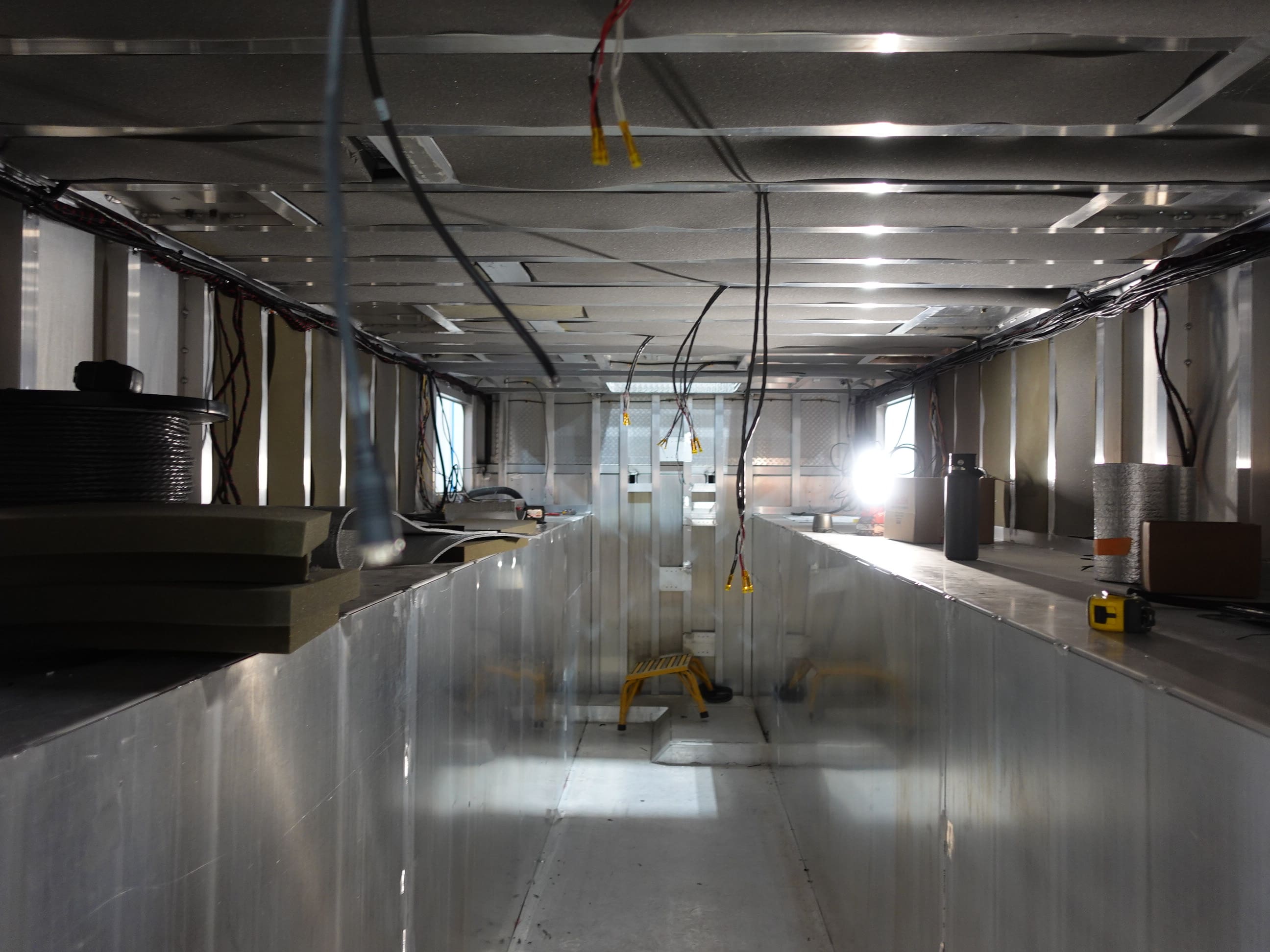

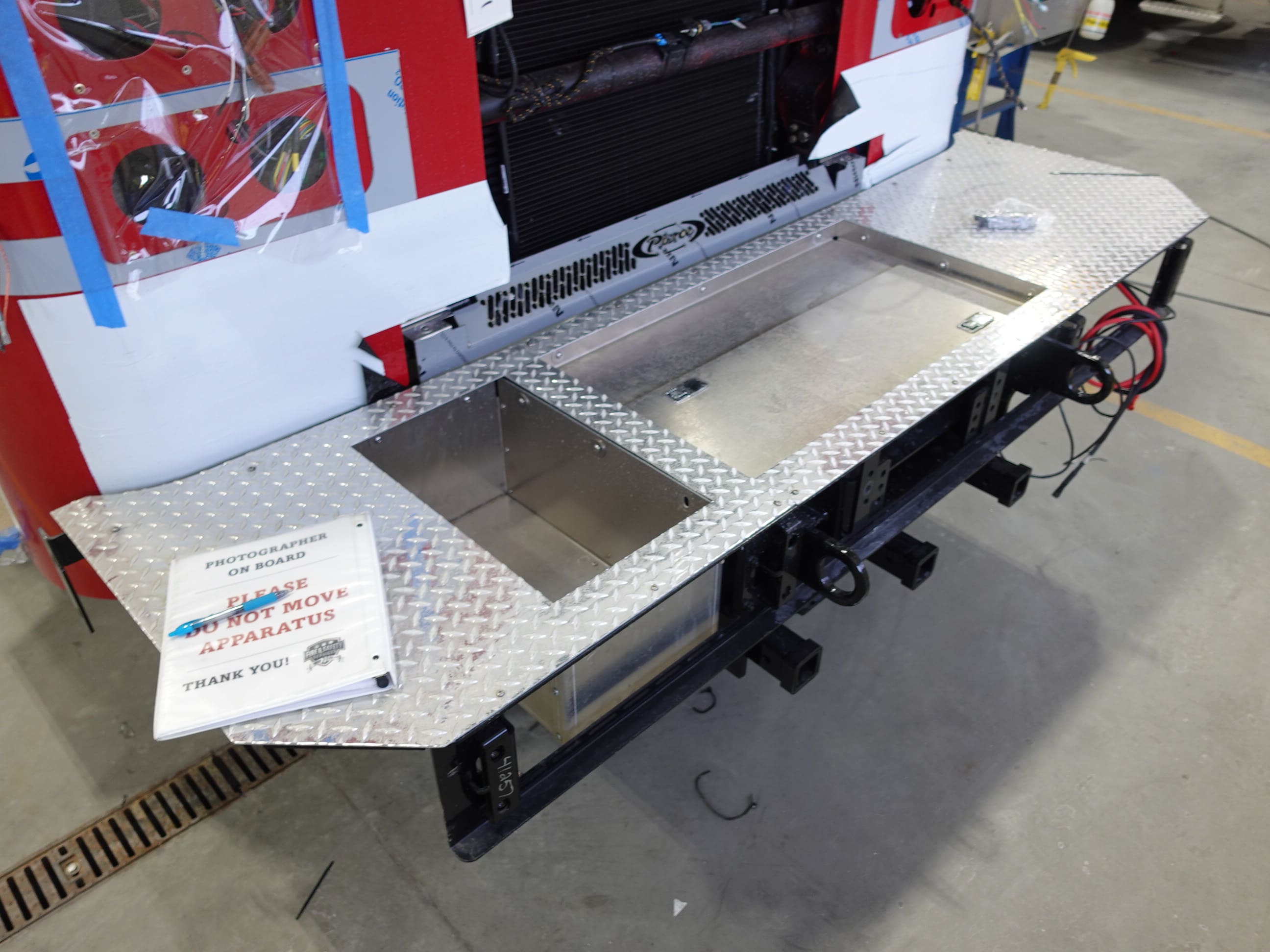

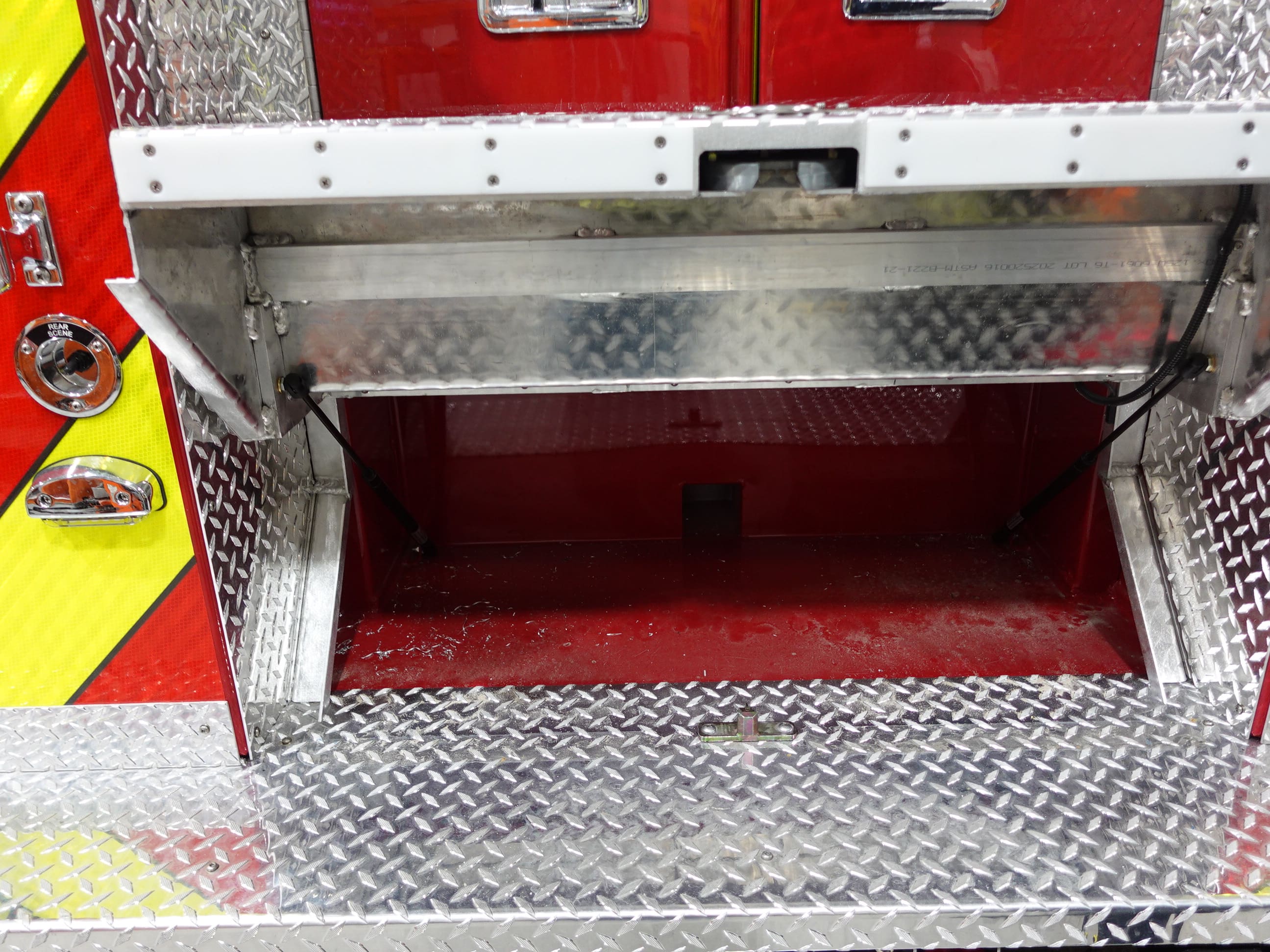

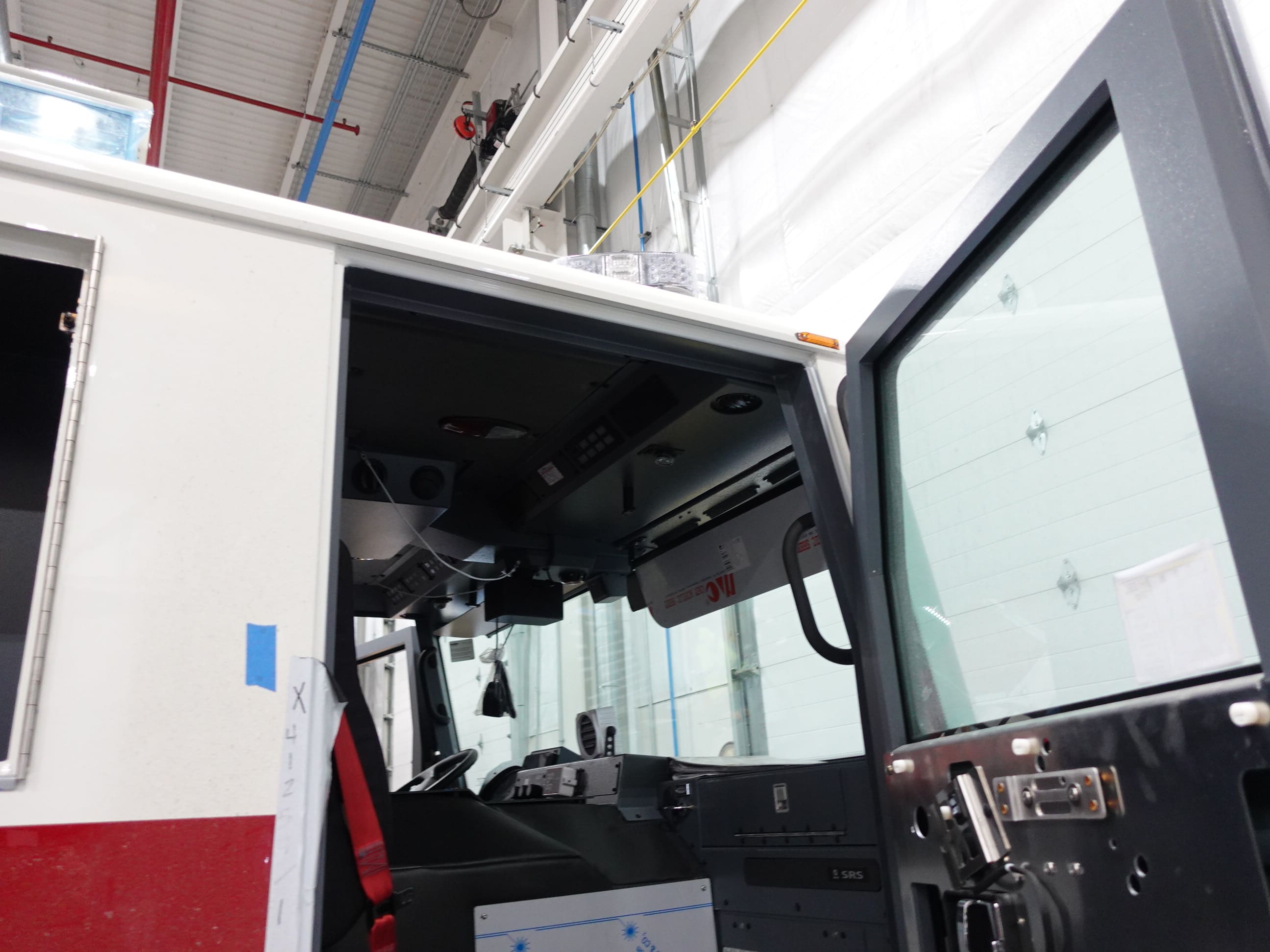

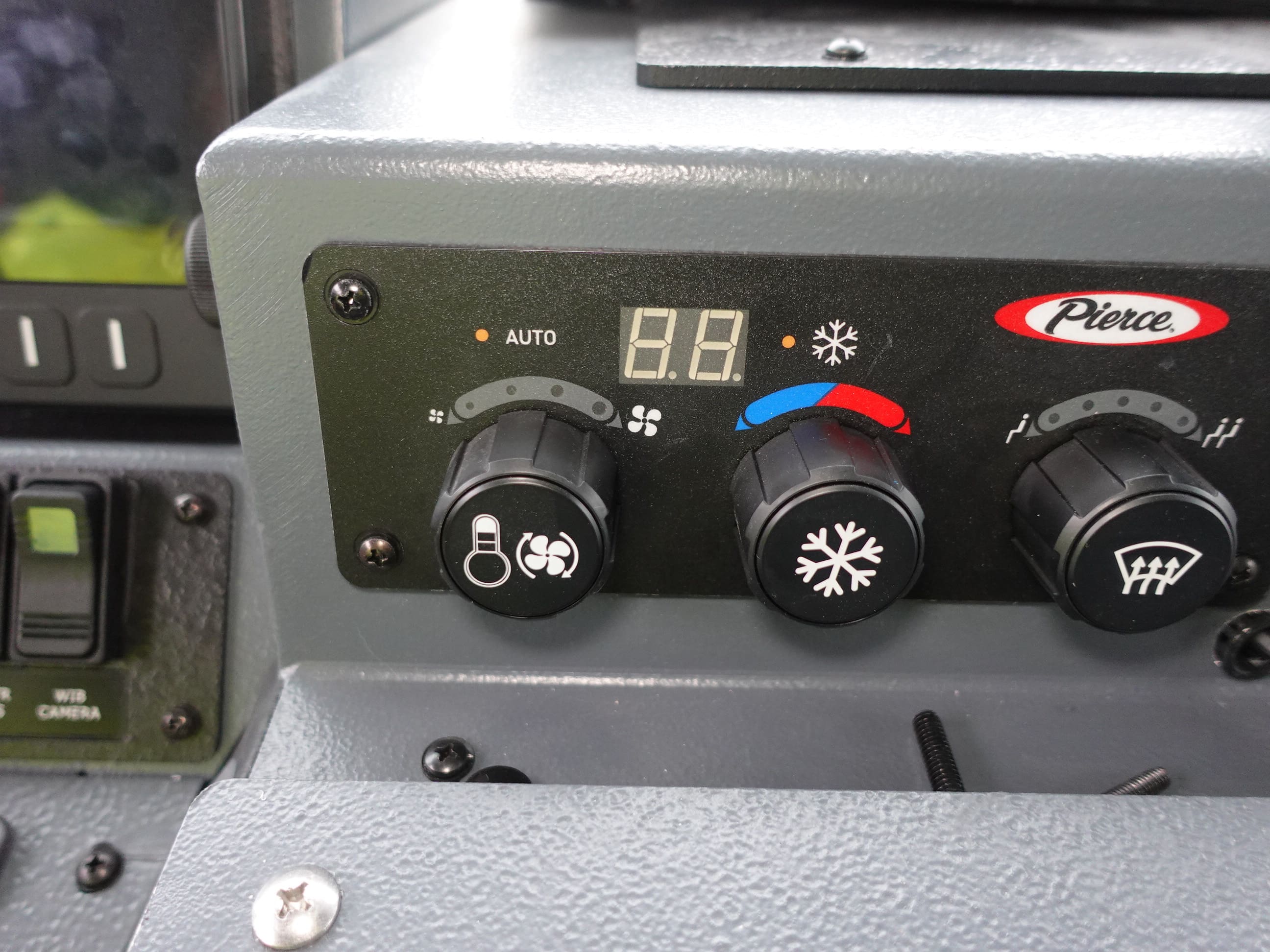

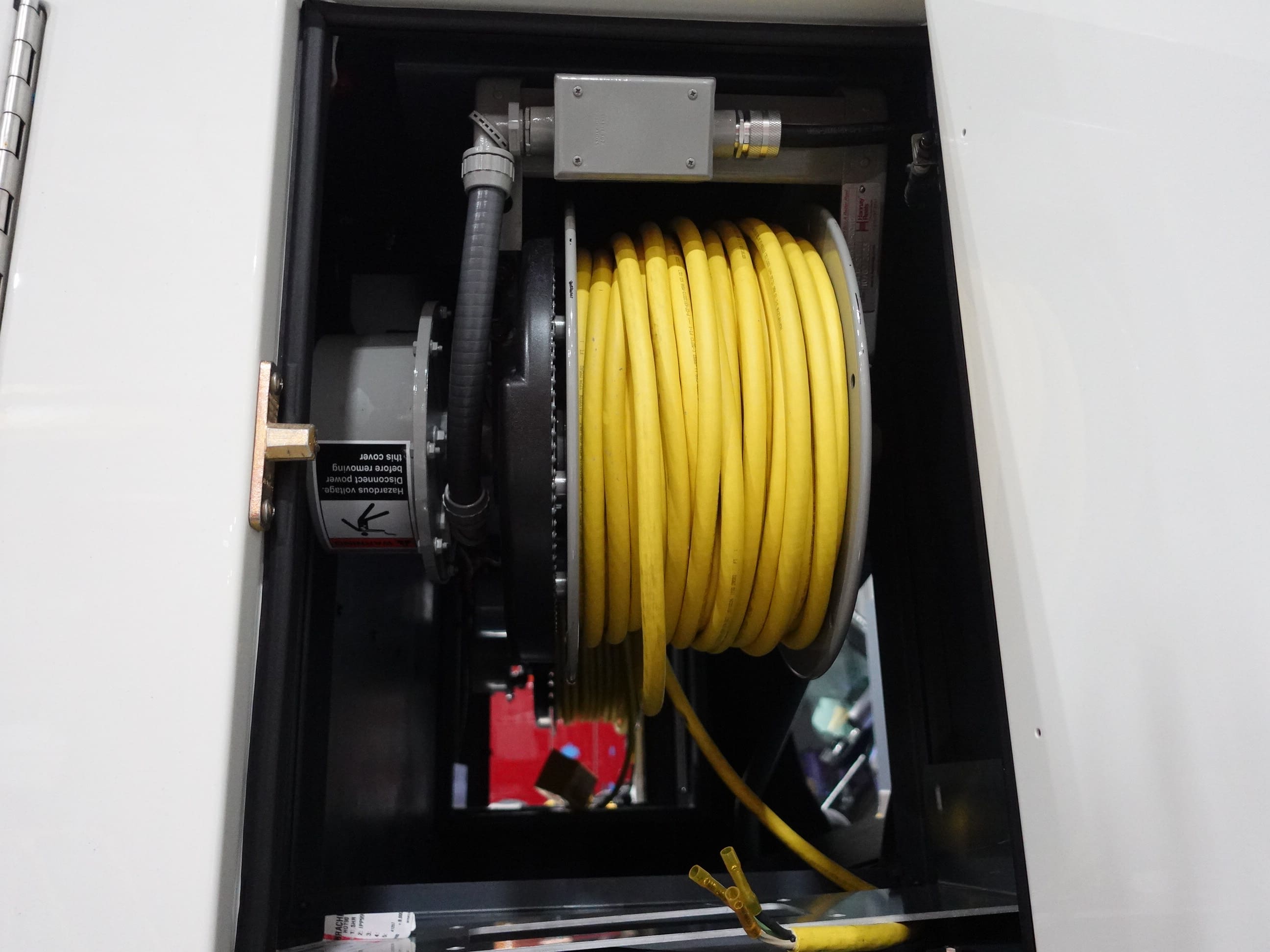

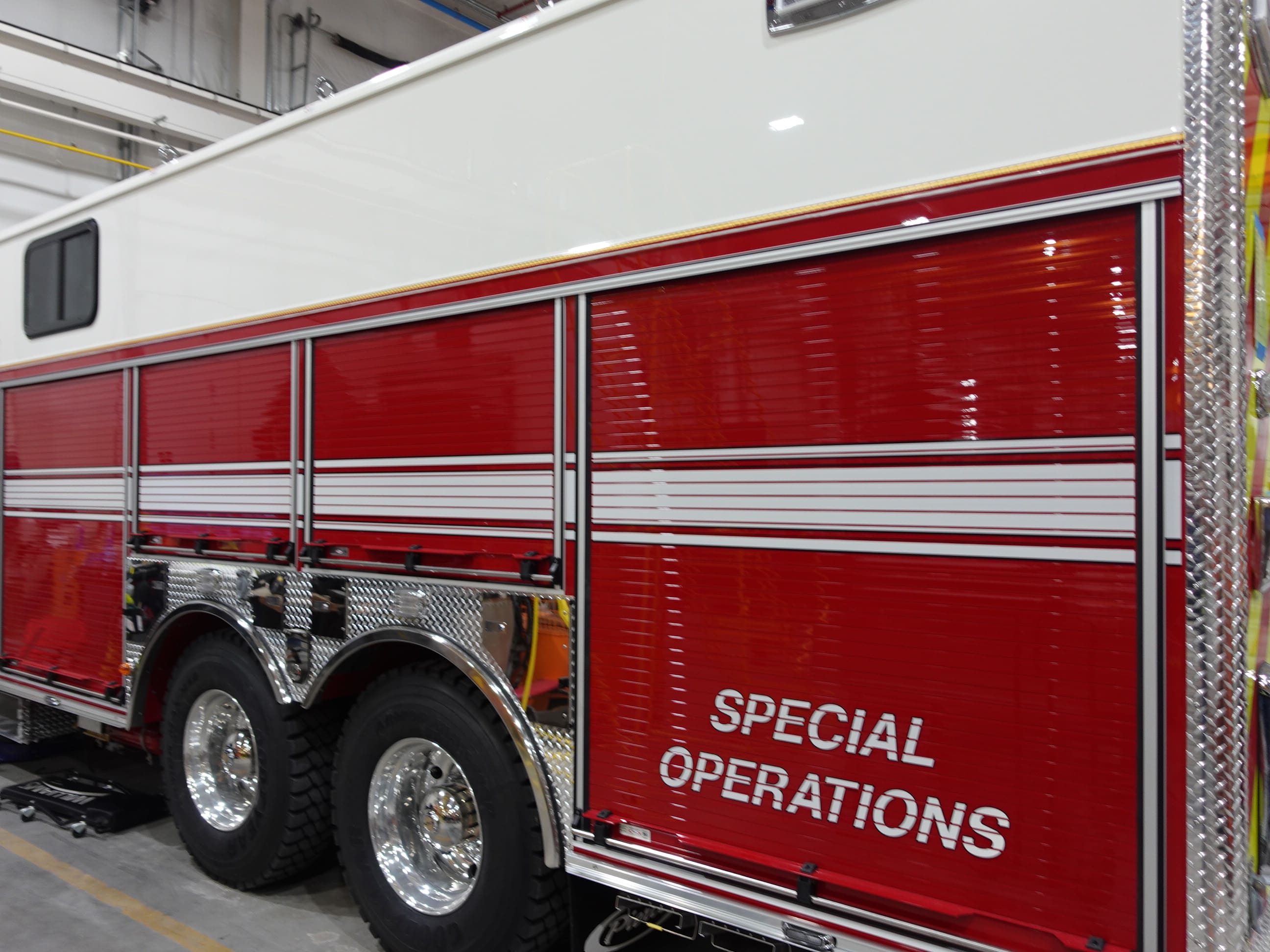

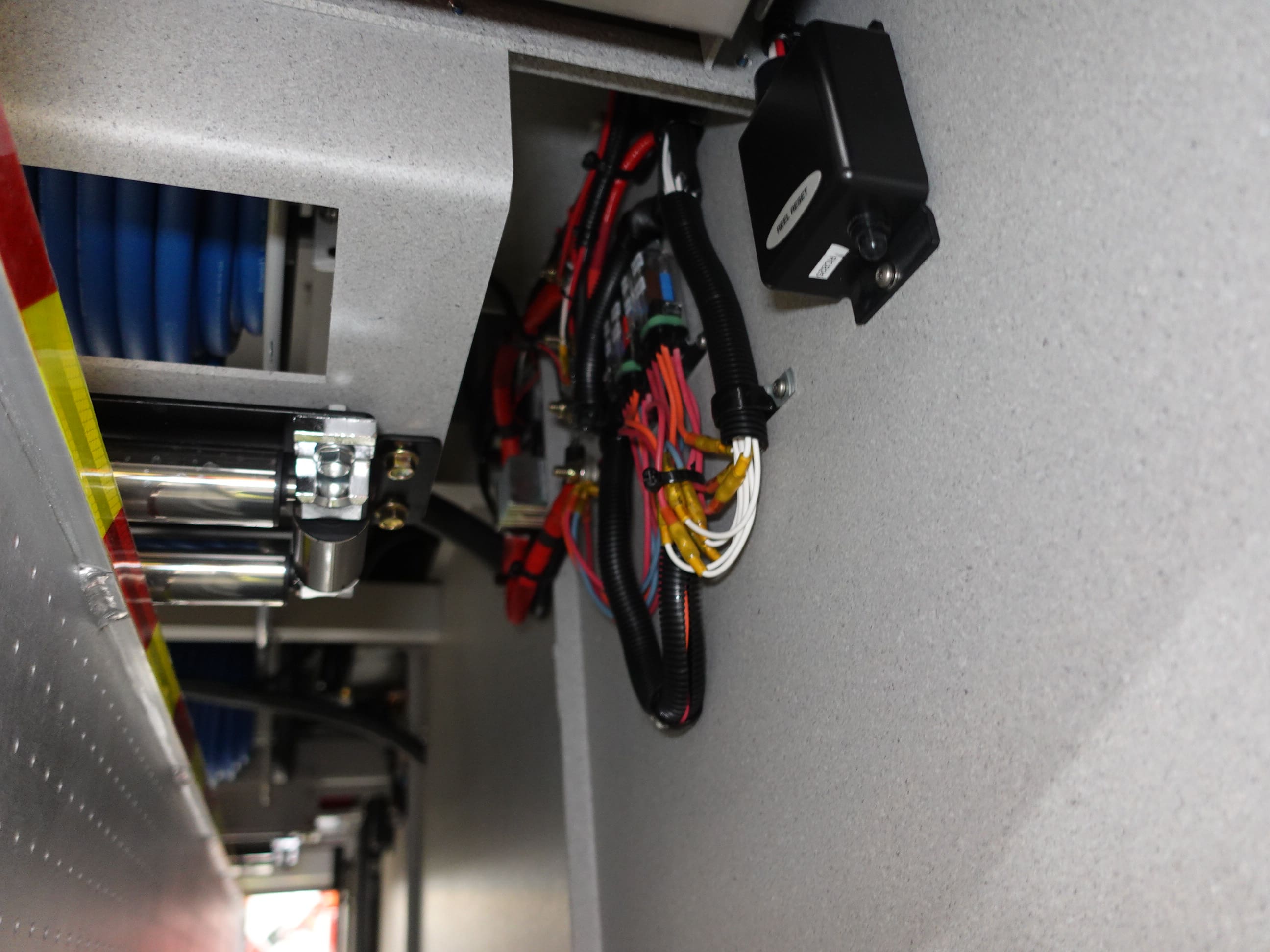

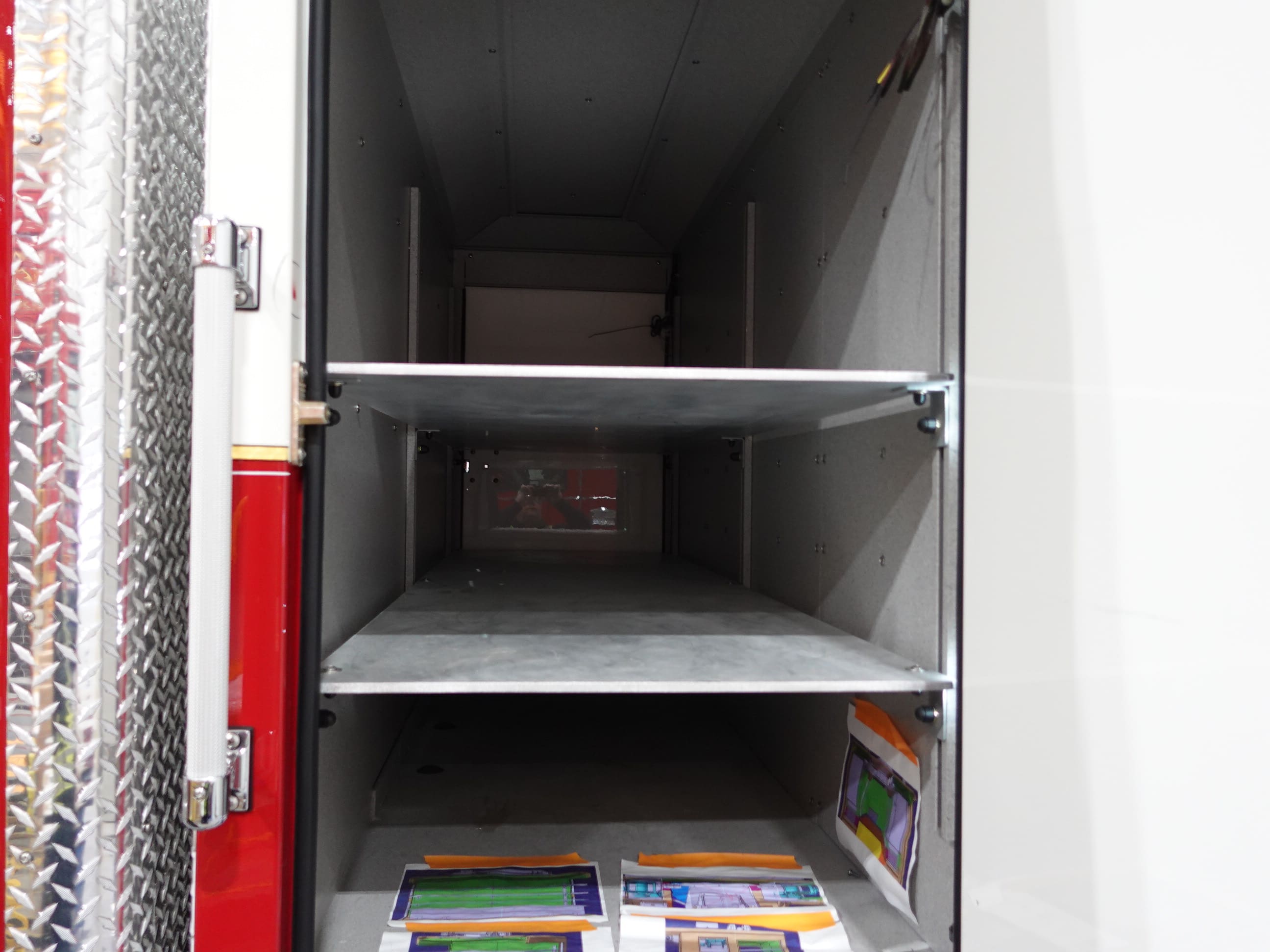

then began the quality and graphics process where

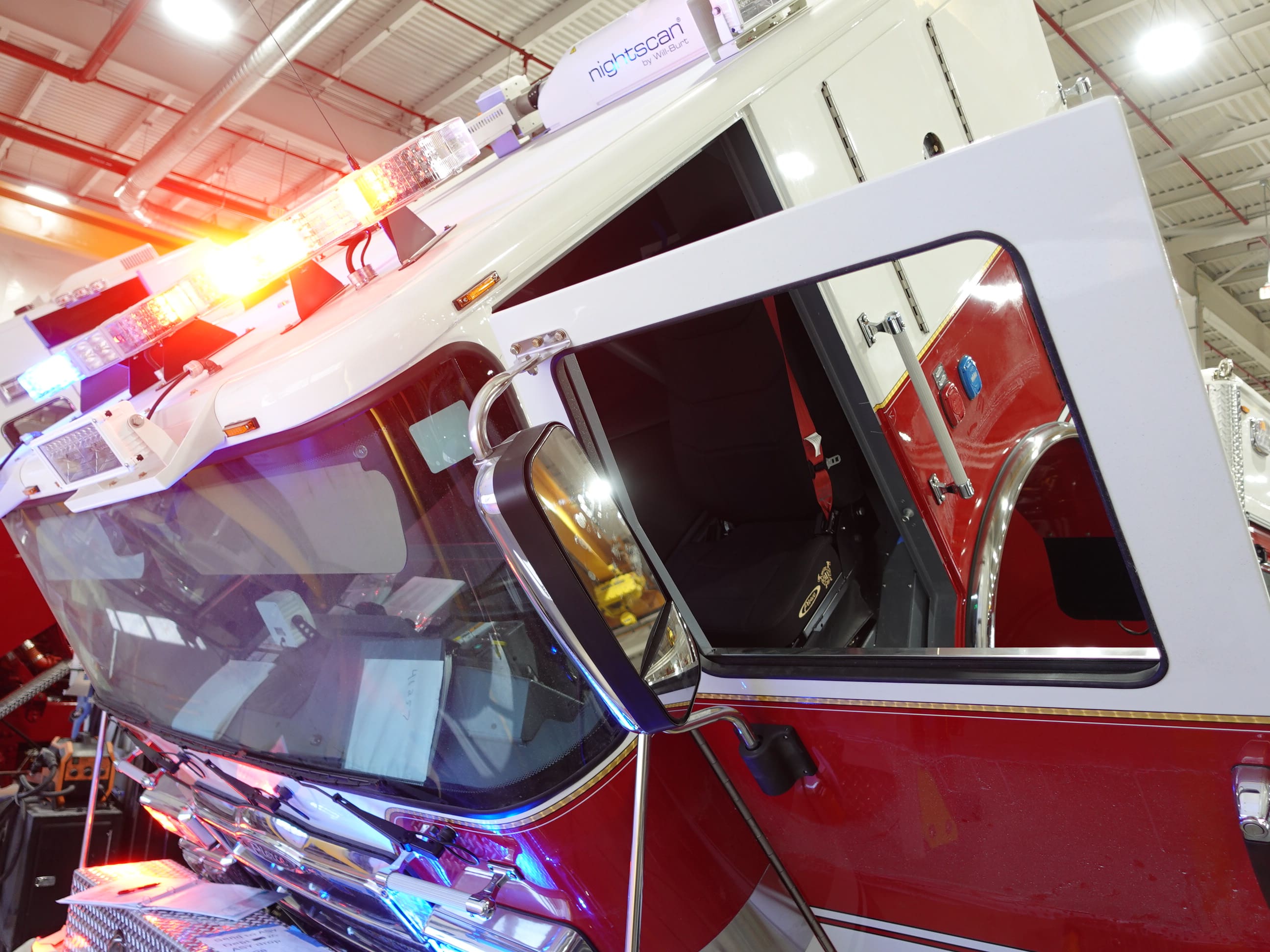

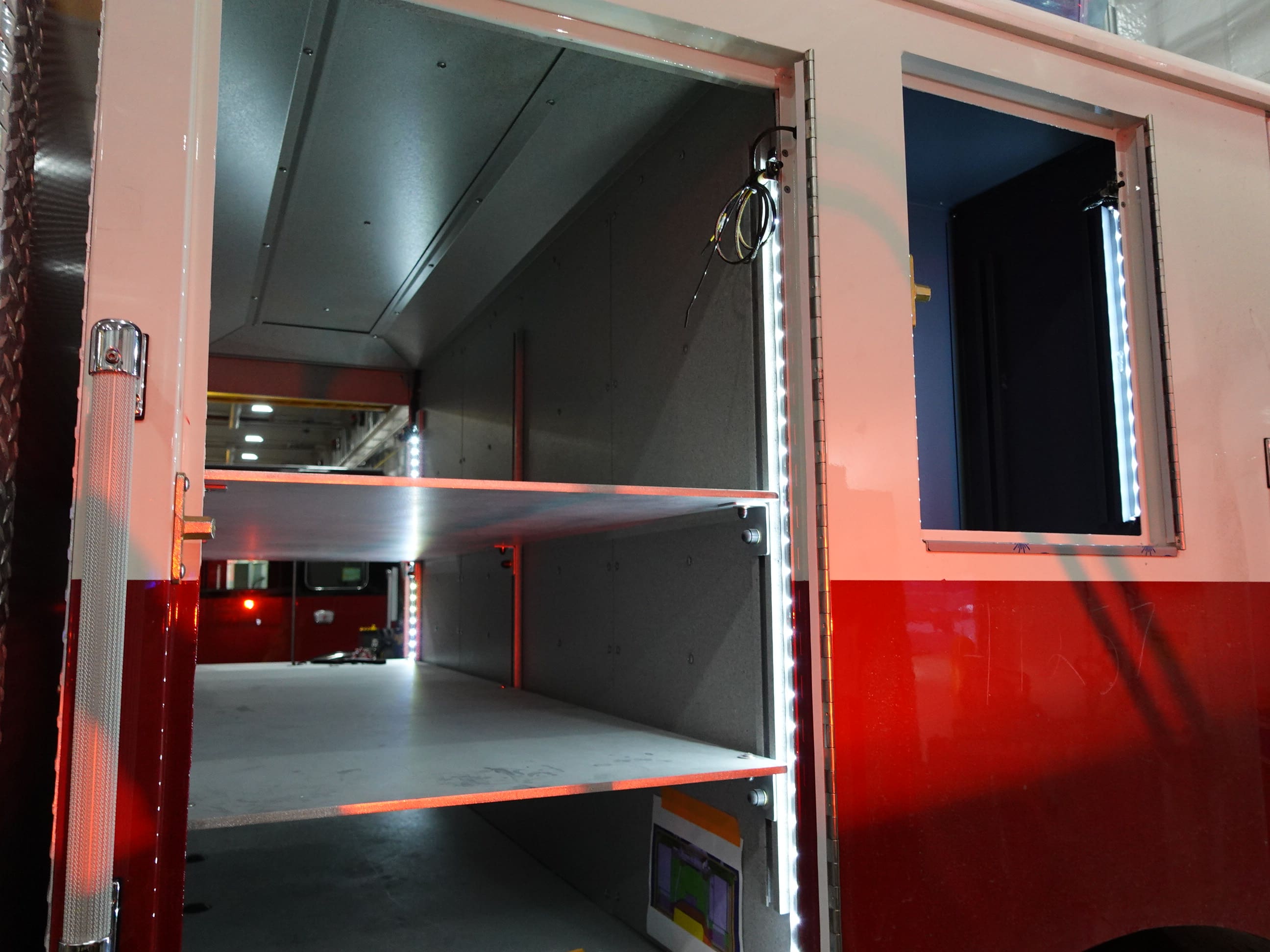

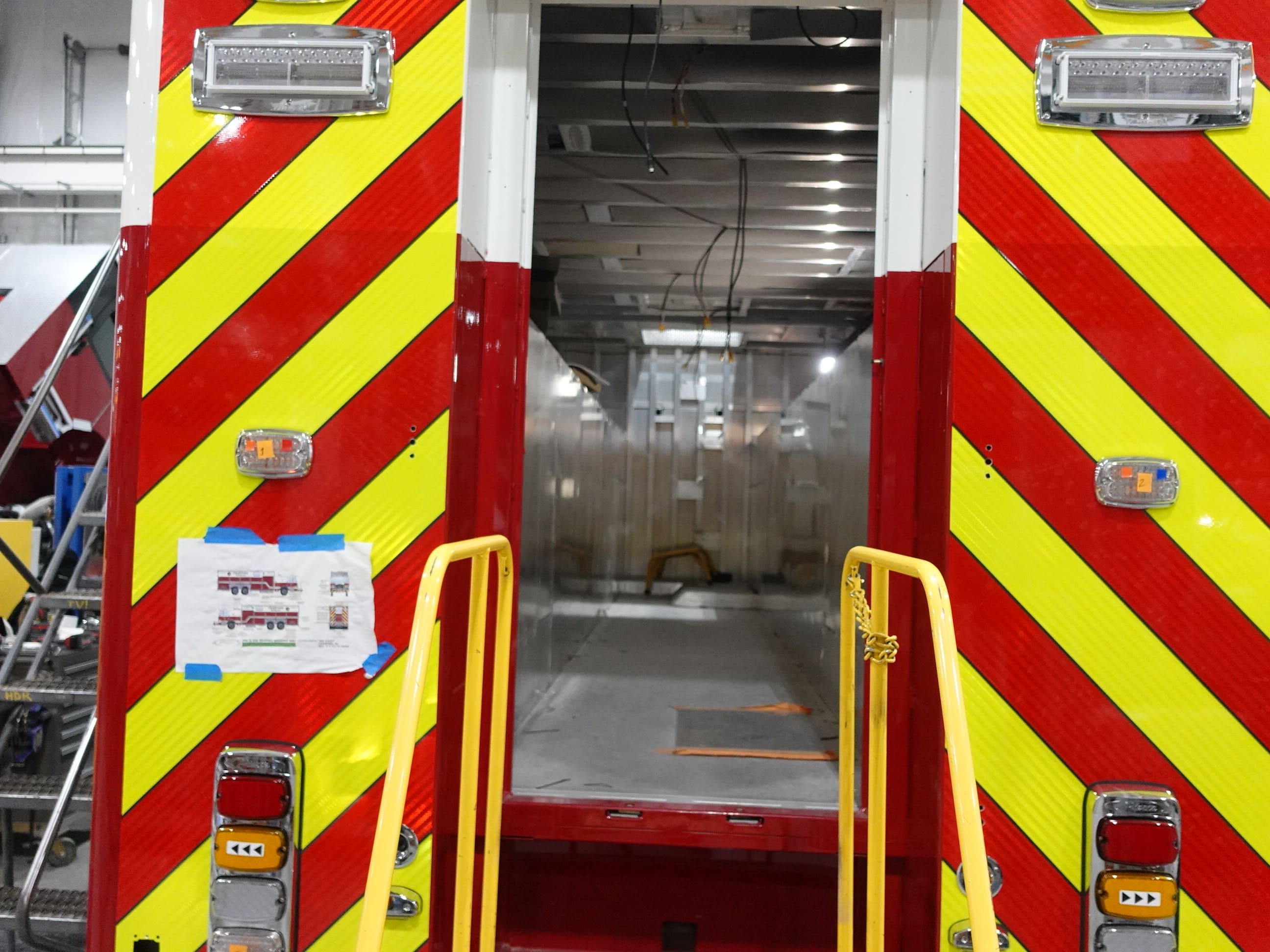

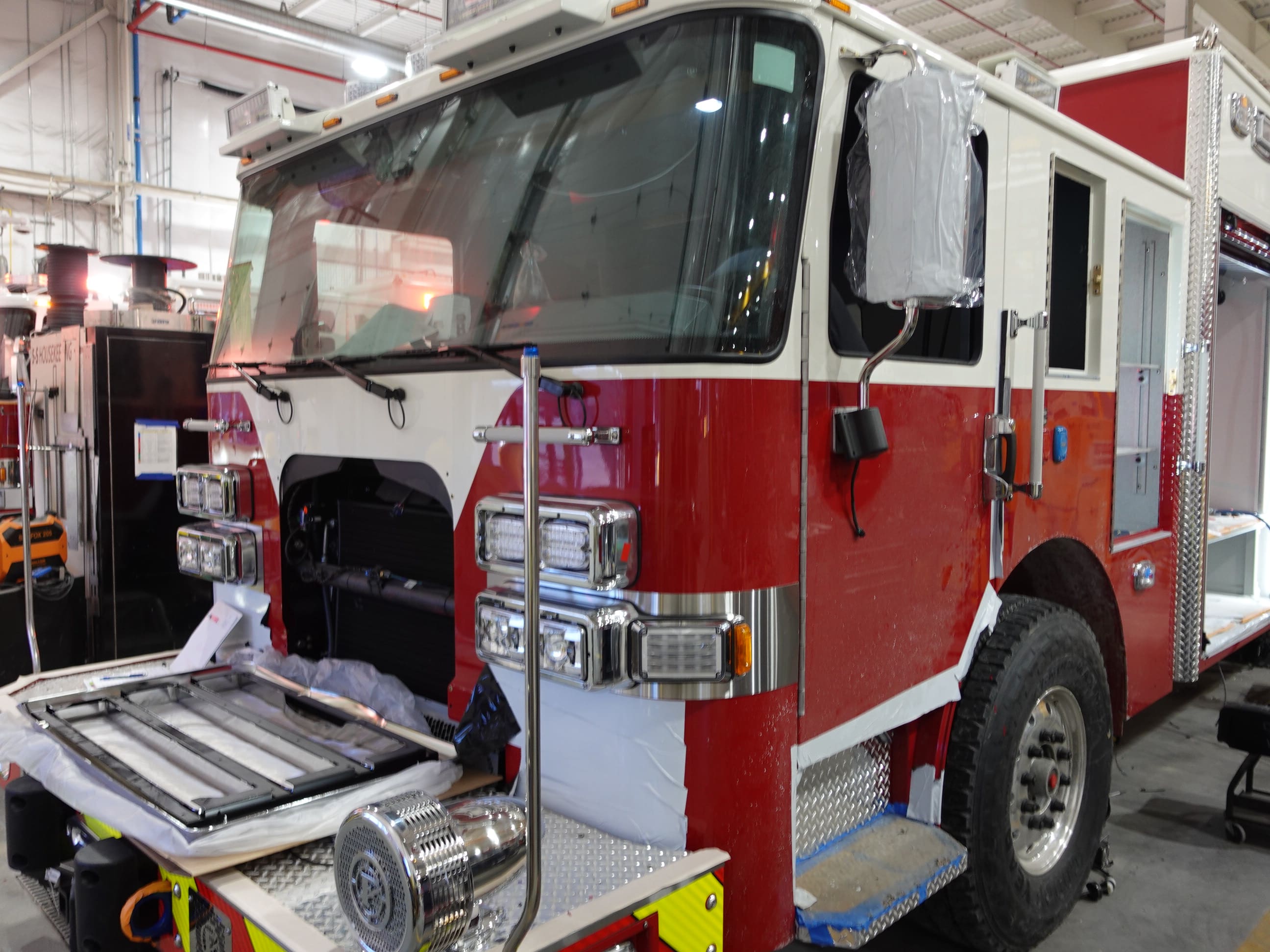

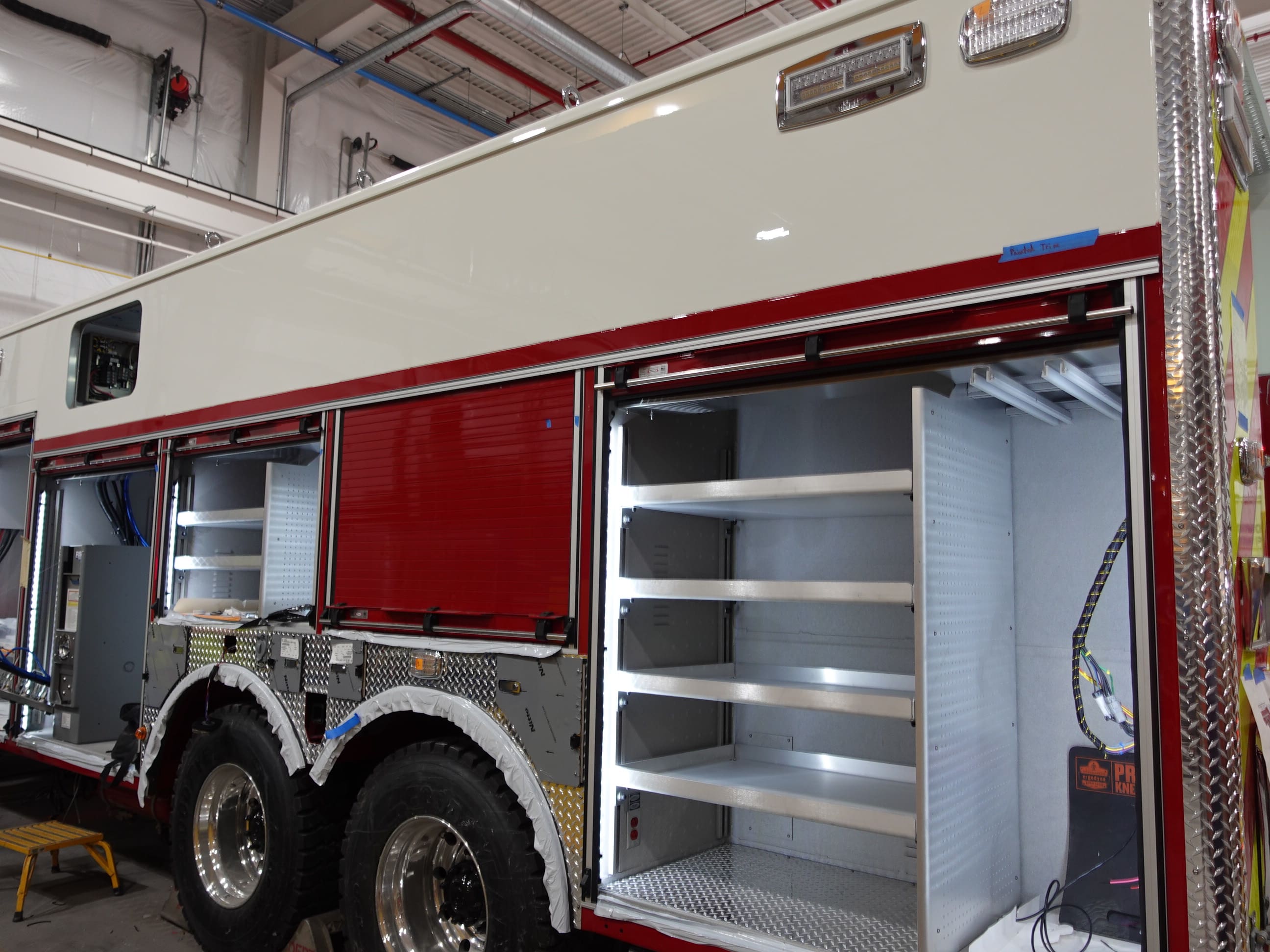

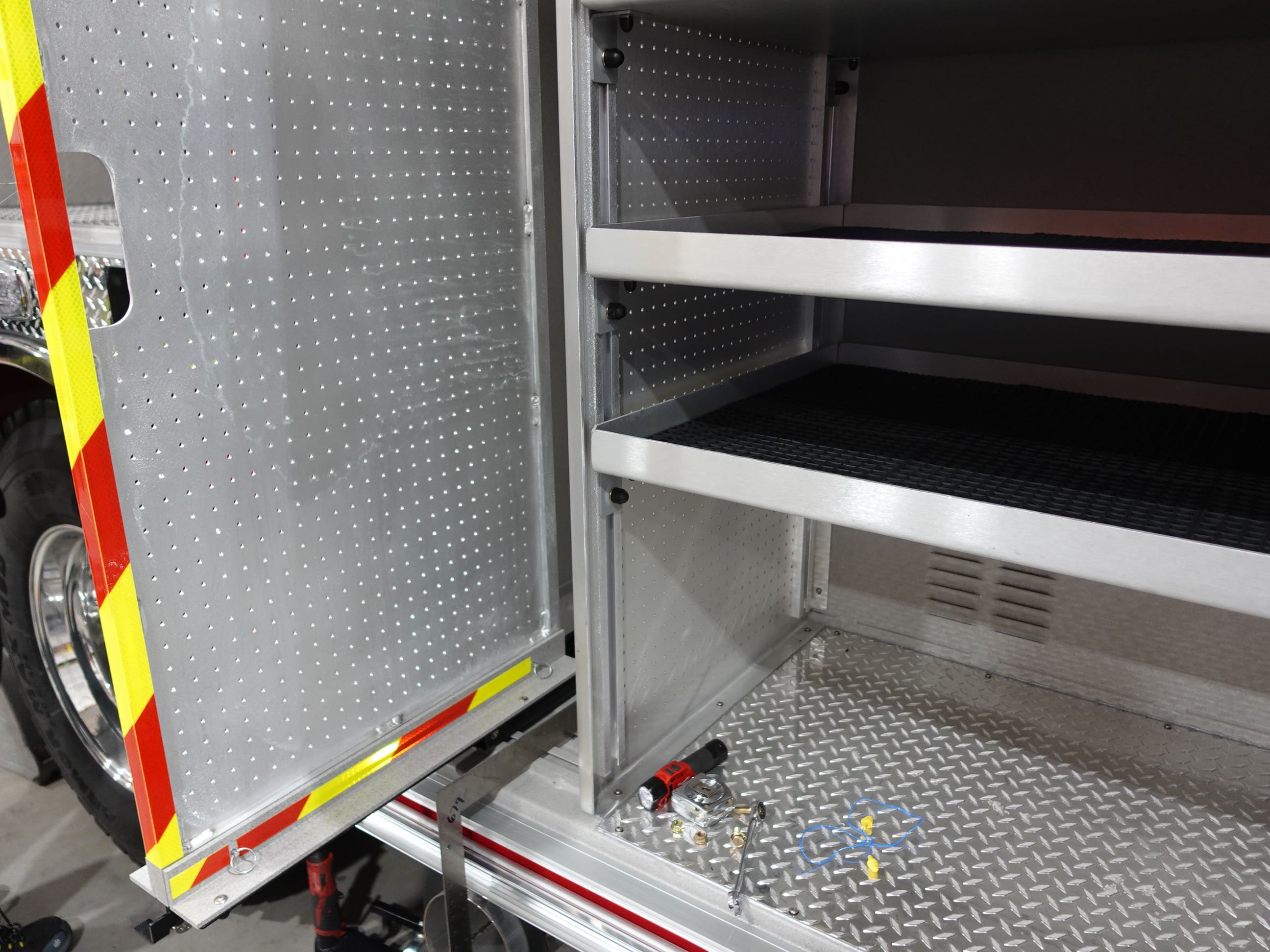

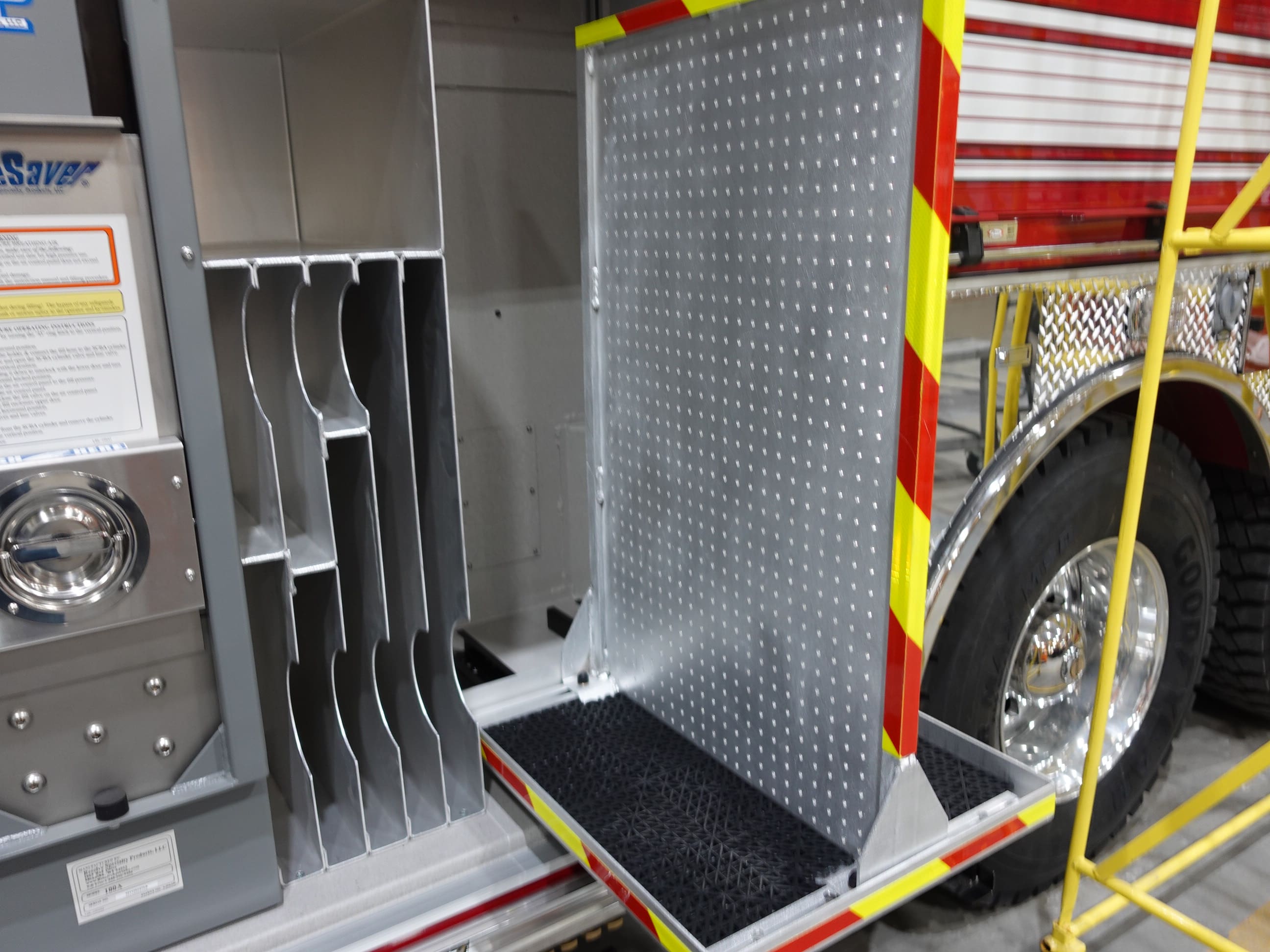

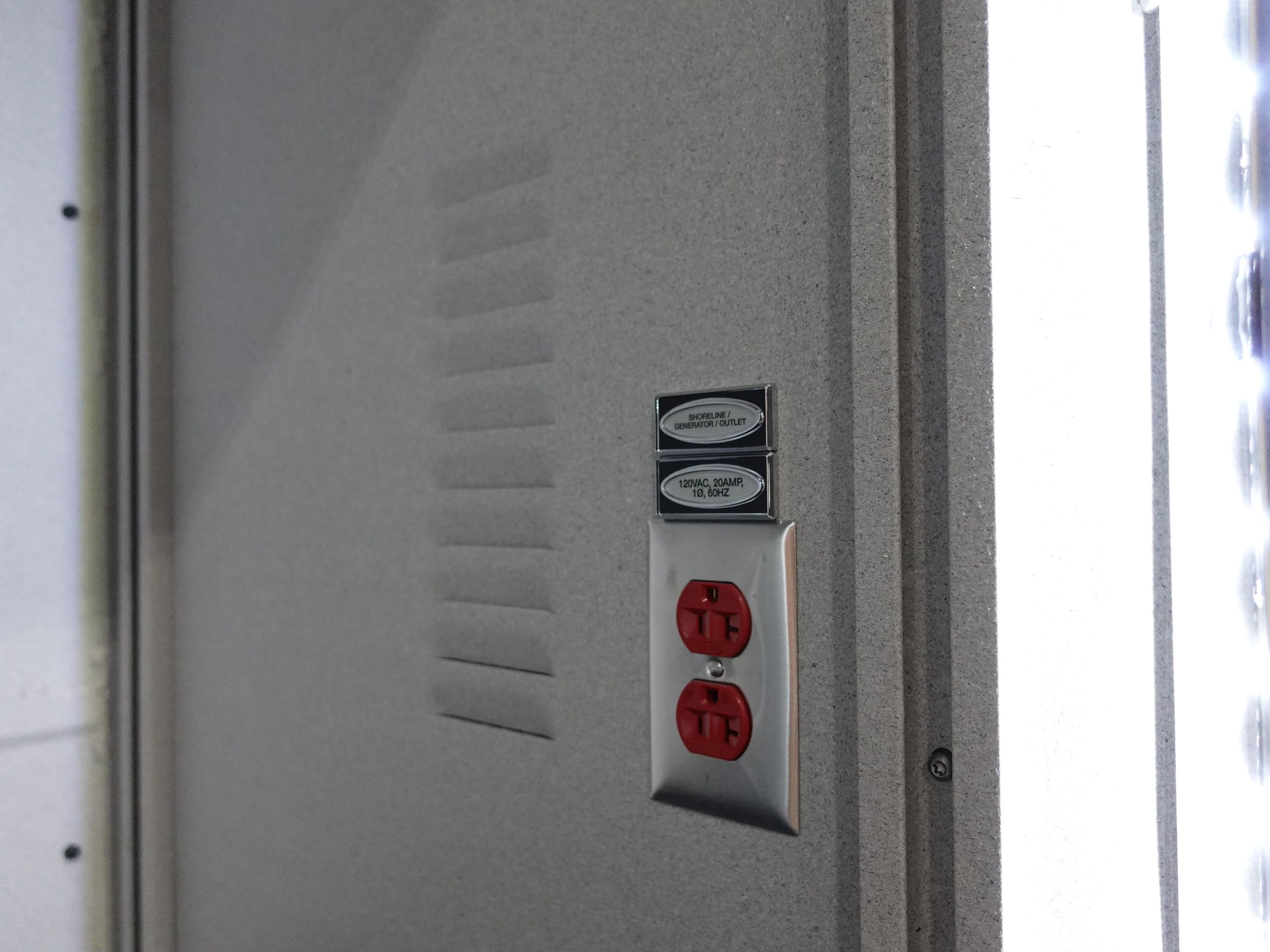

any remaining content is applied. Once finished it

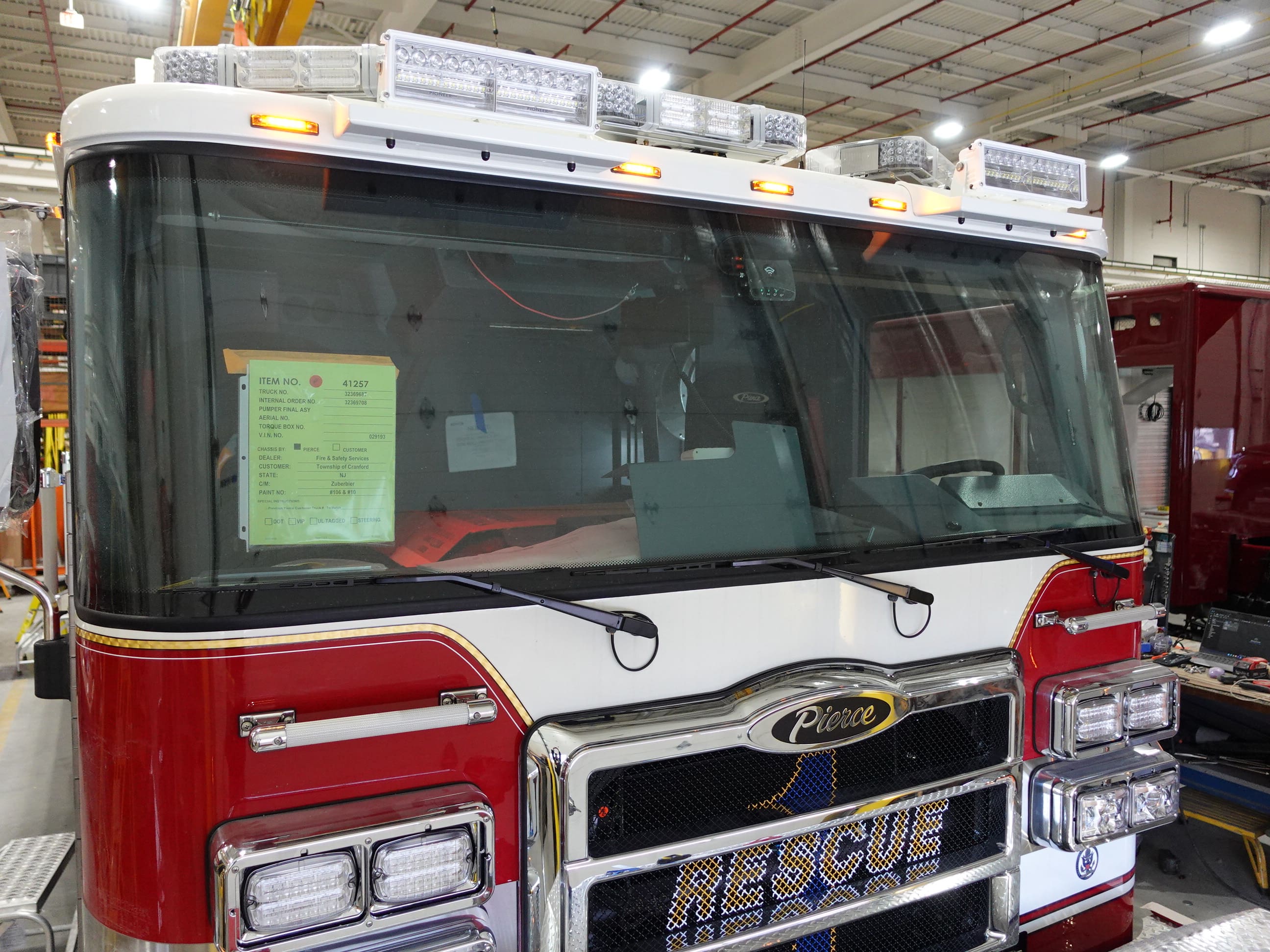

will be made ready for the customer acceptance

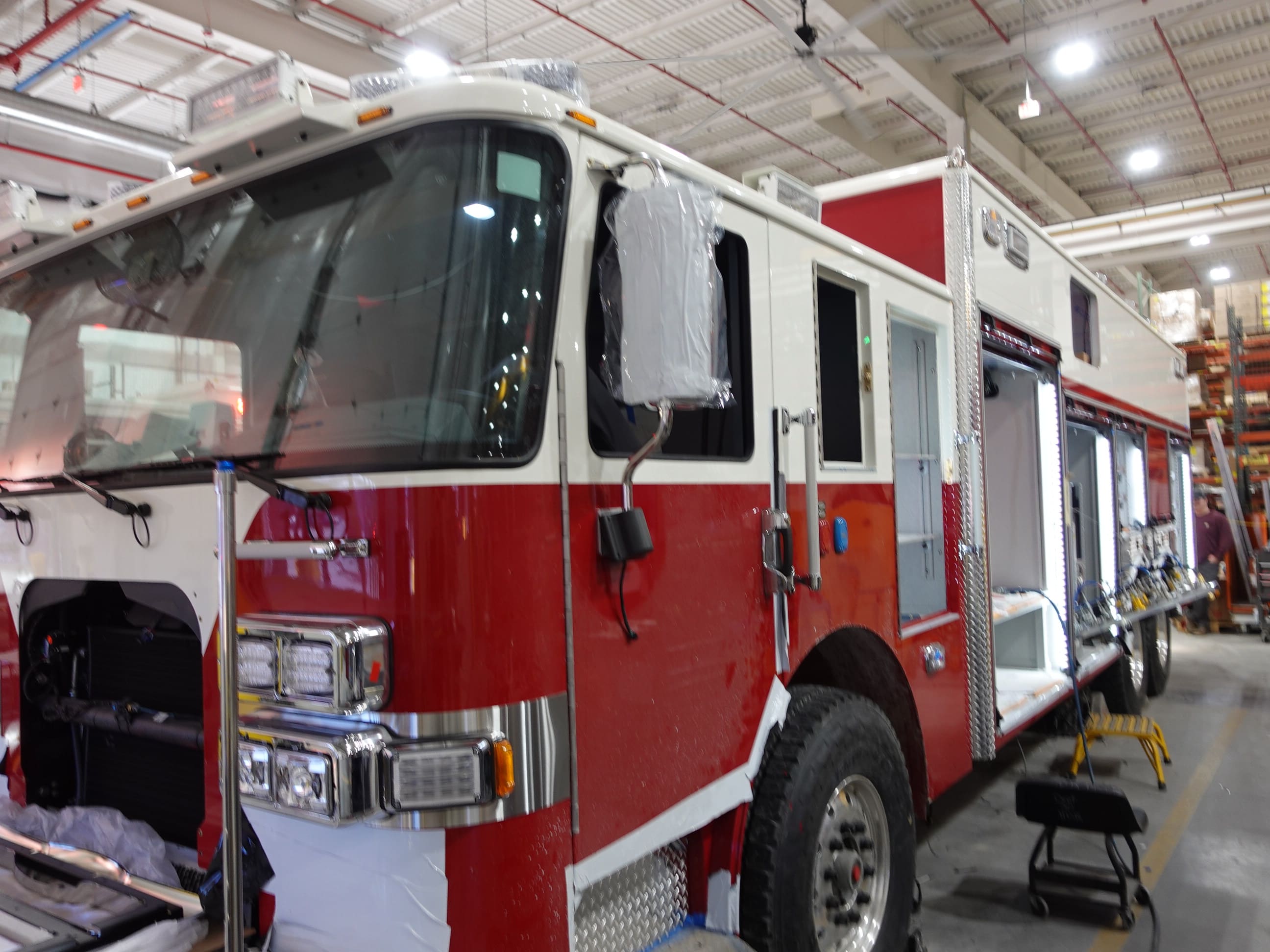

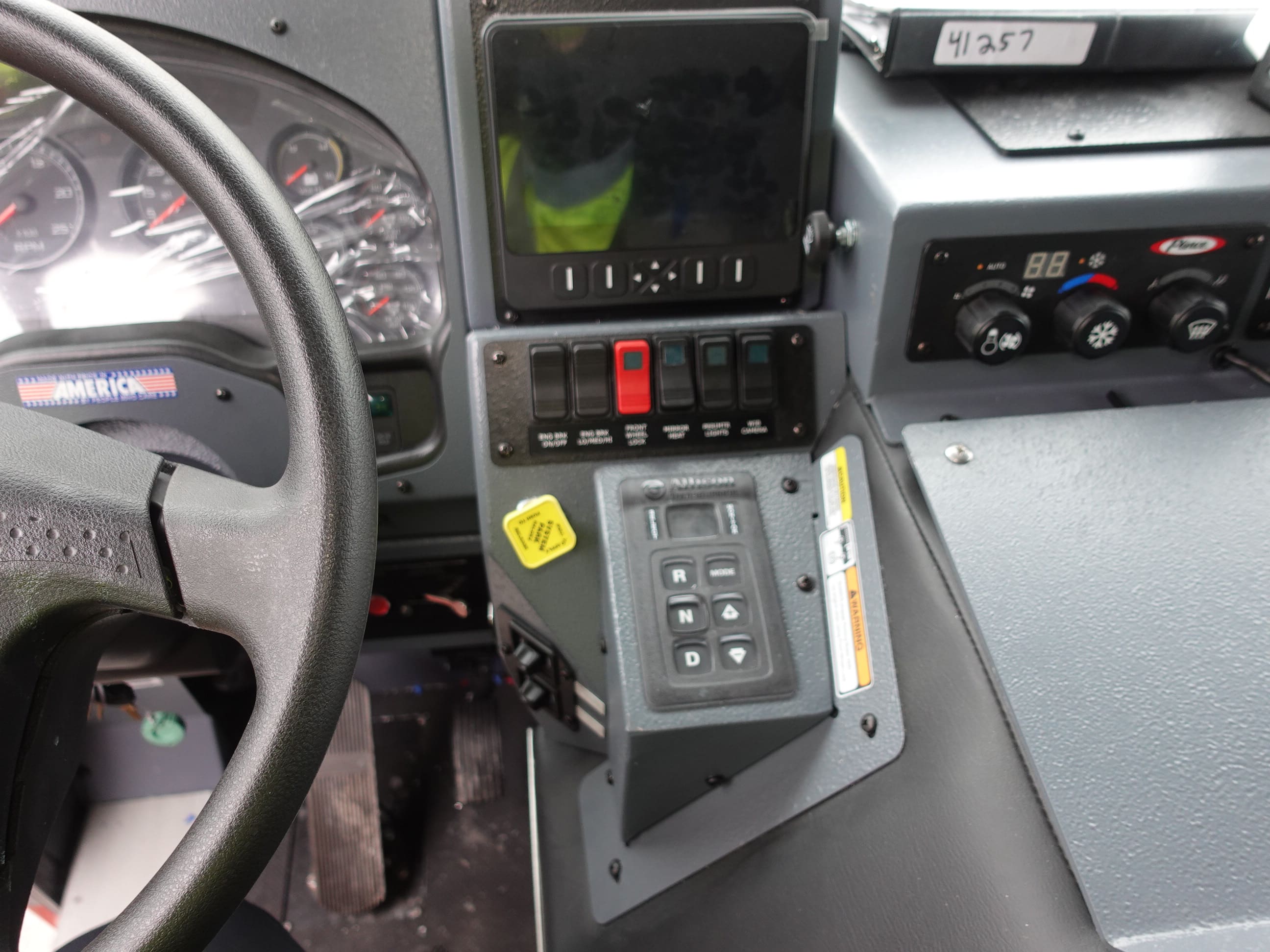

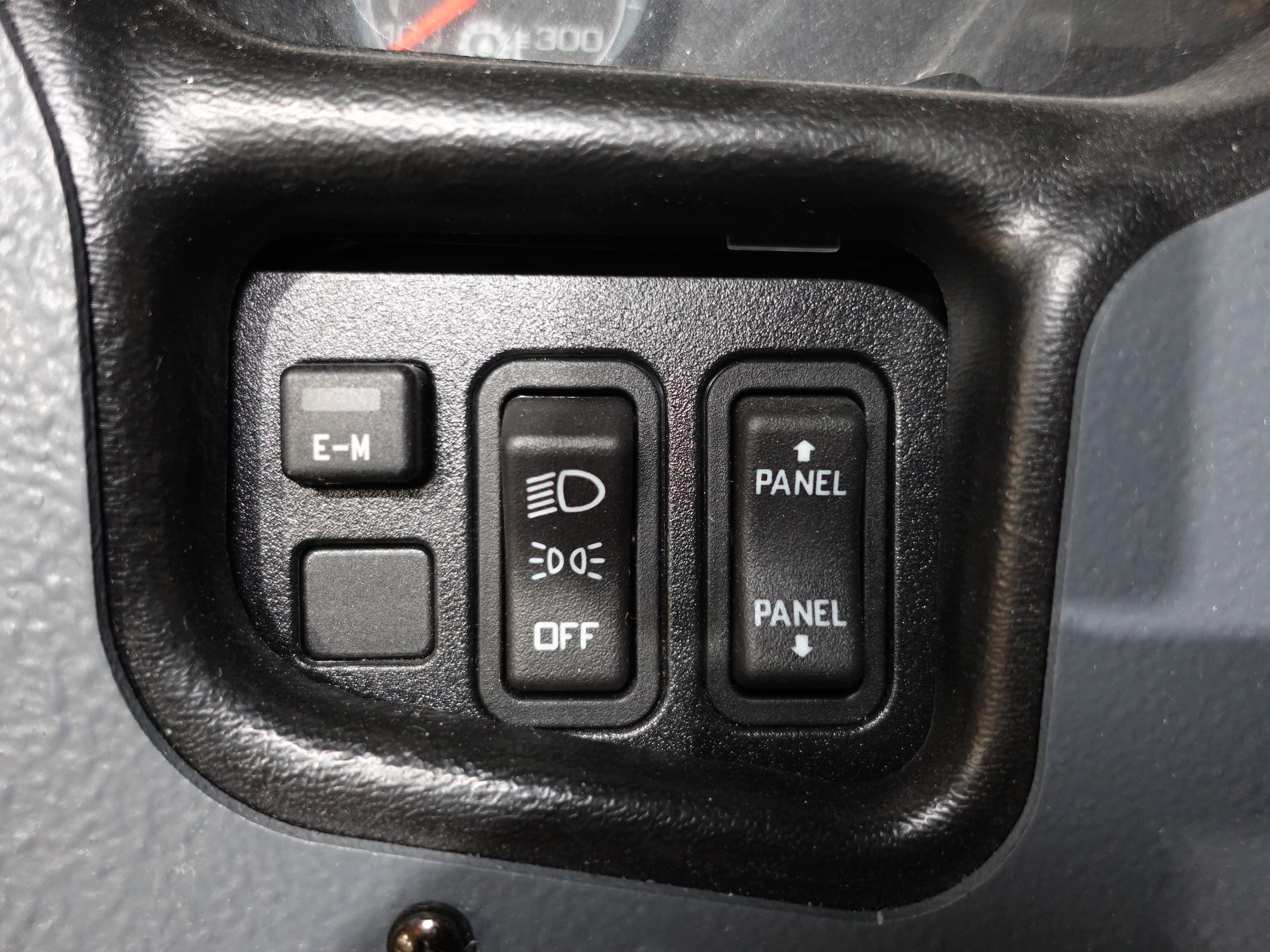

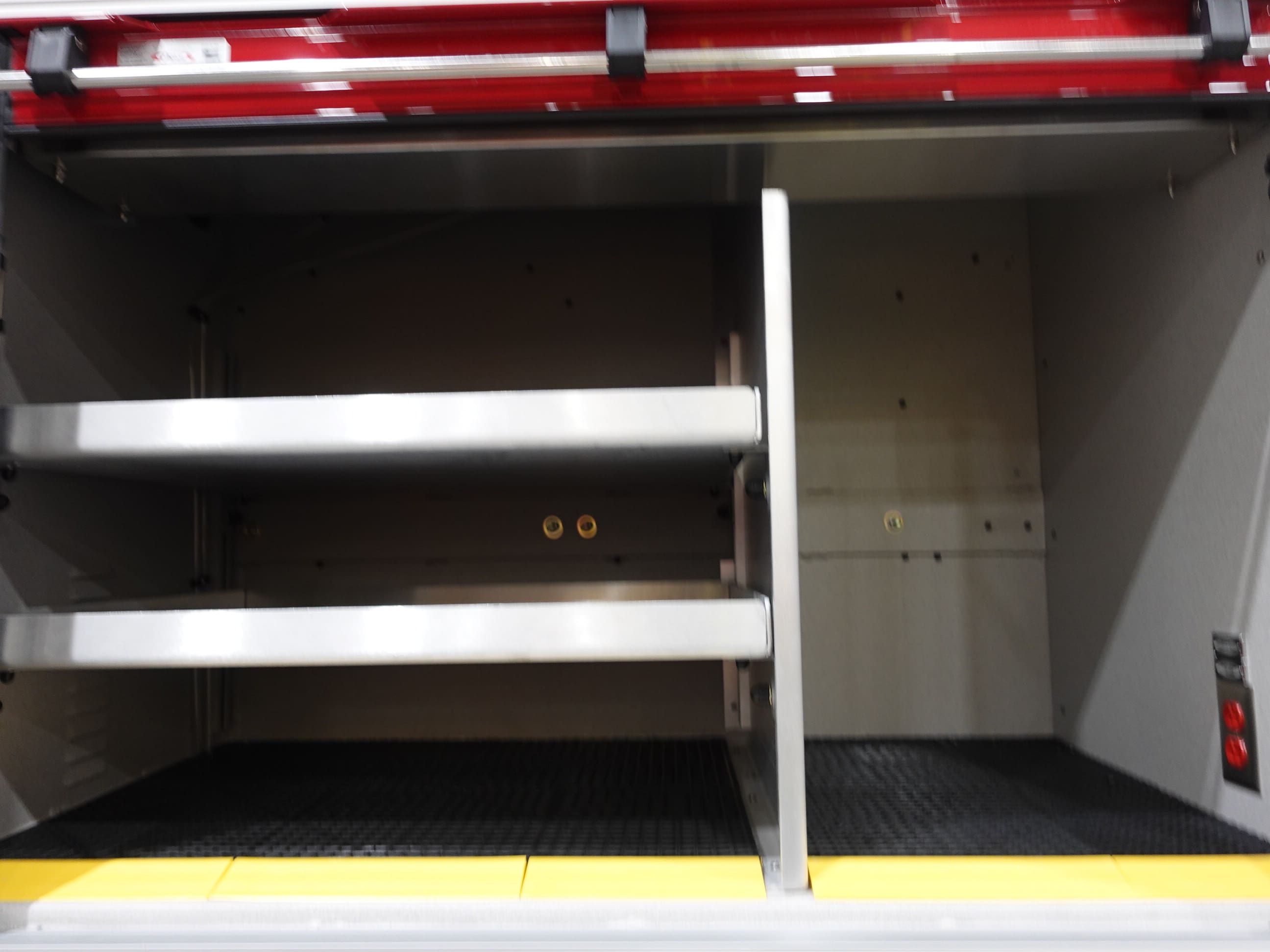

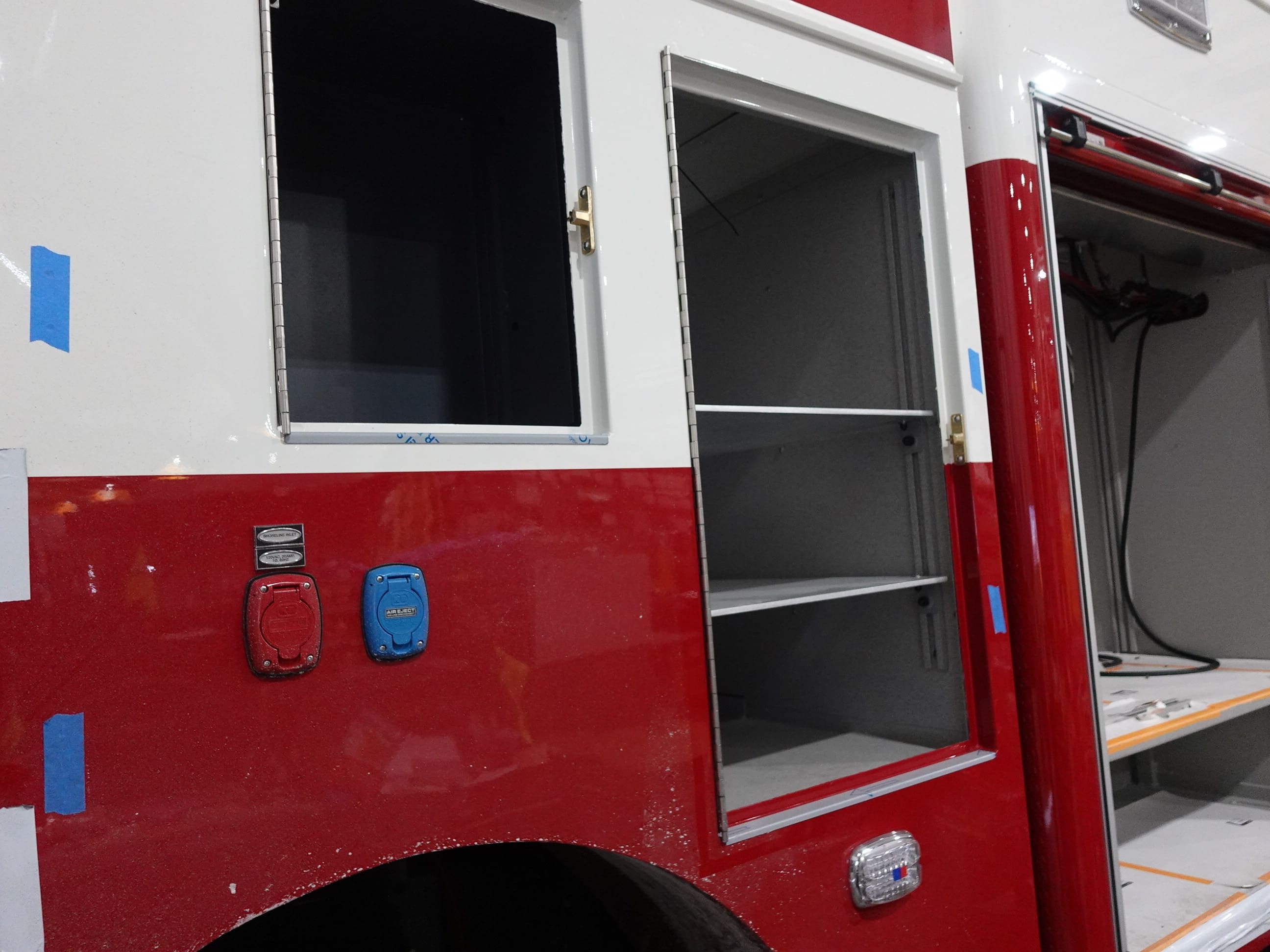

inspection. This is the last scheduled report.

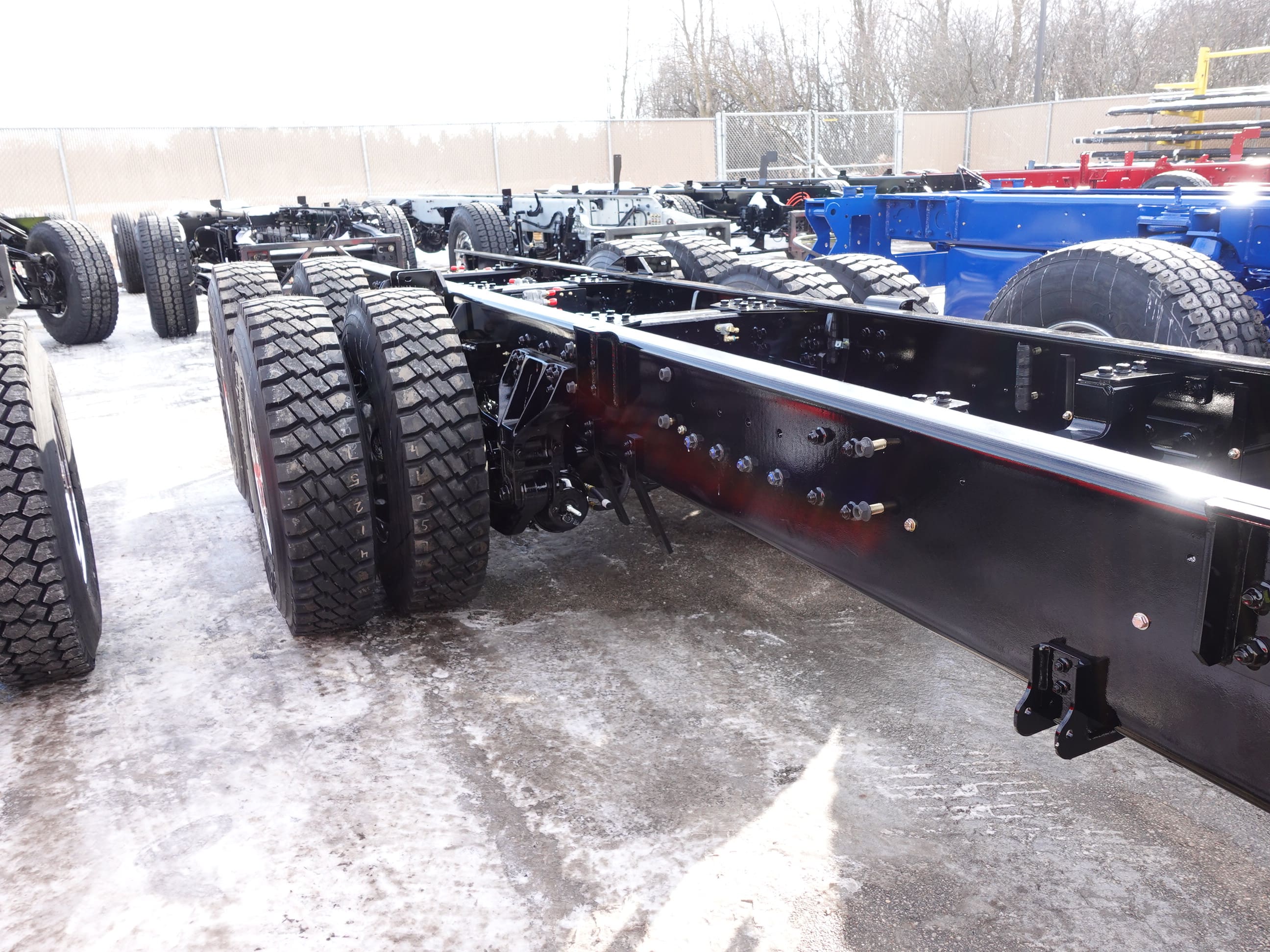

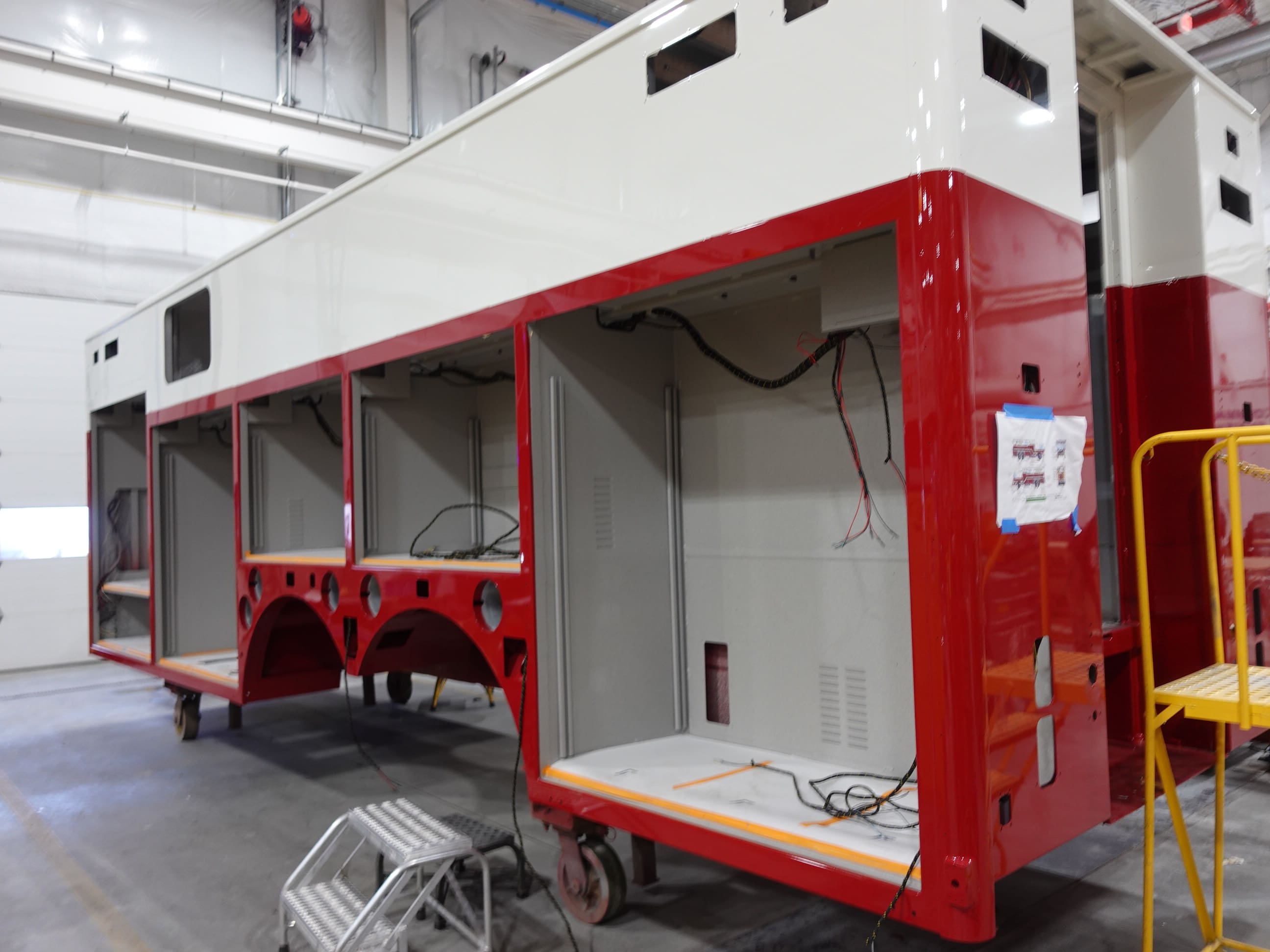

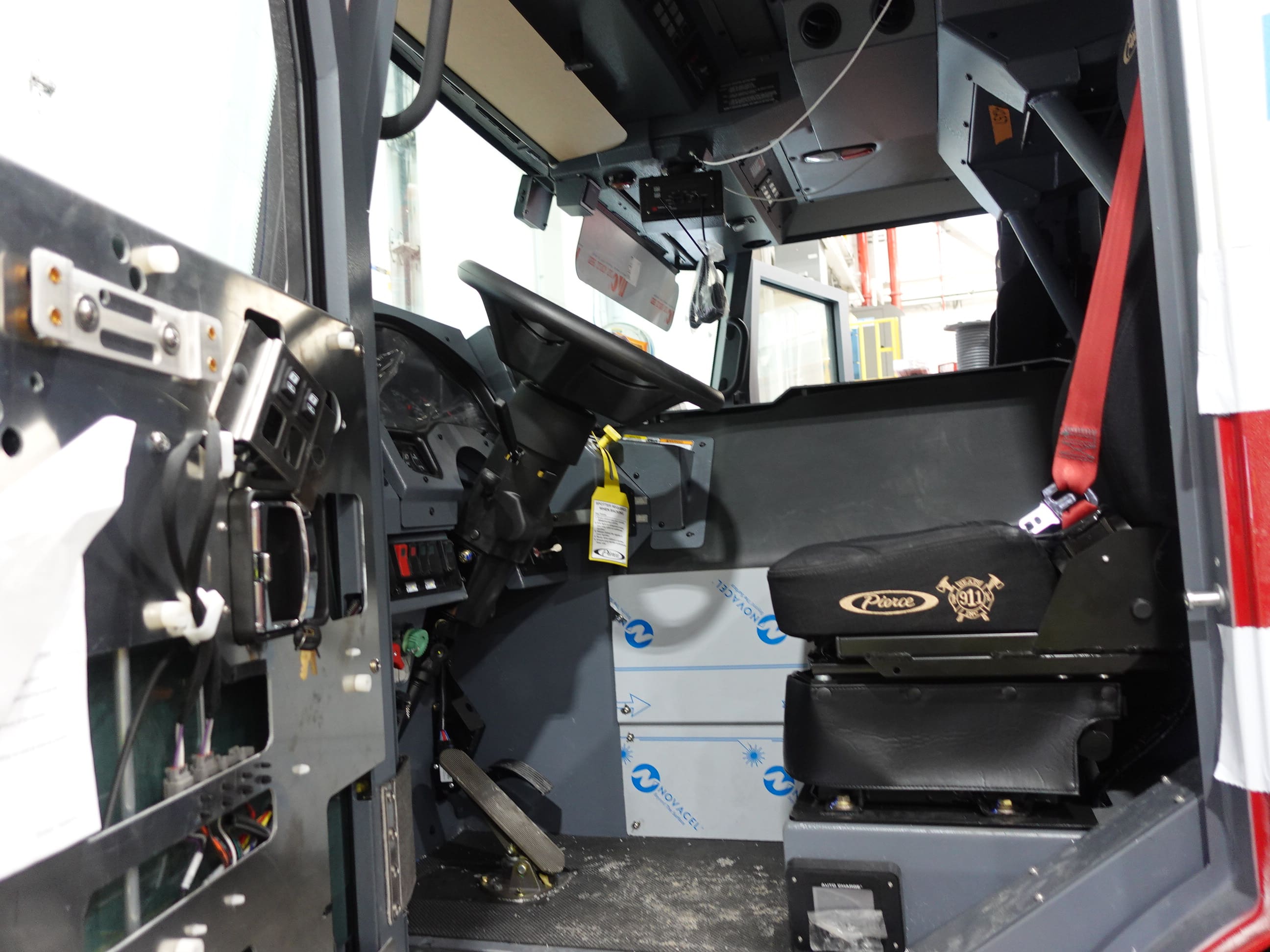

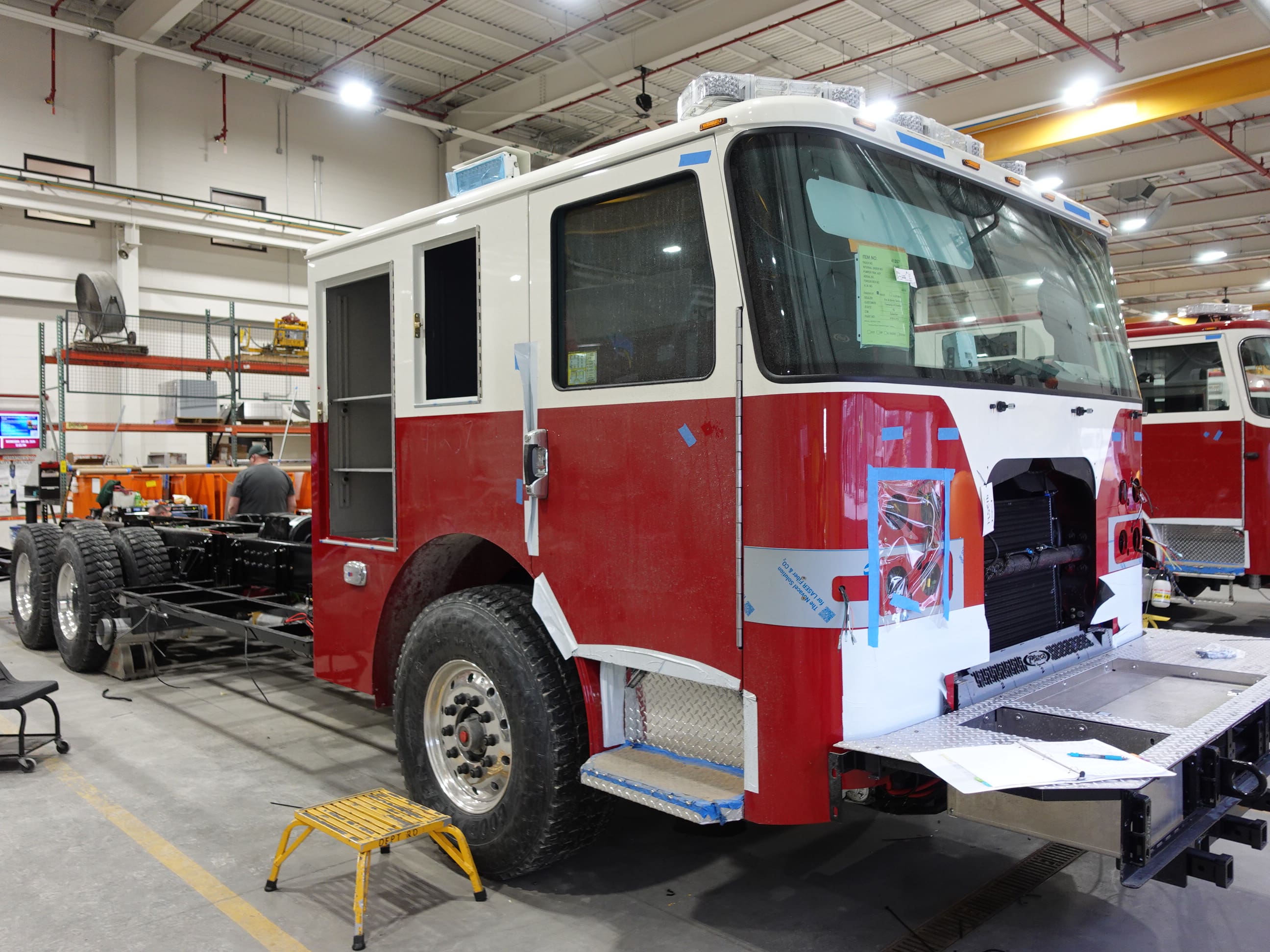

01-30-26

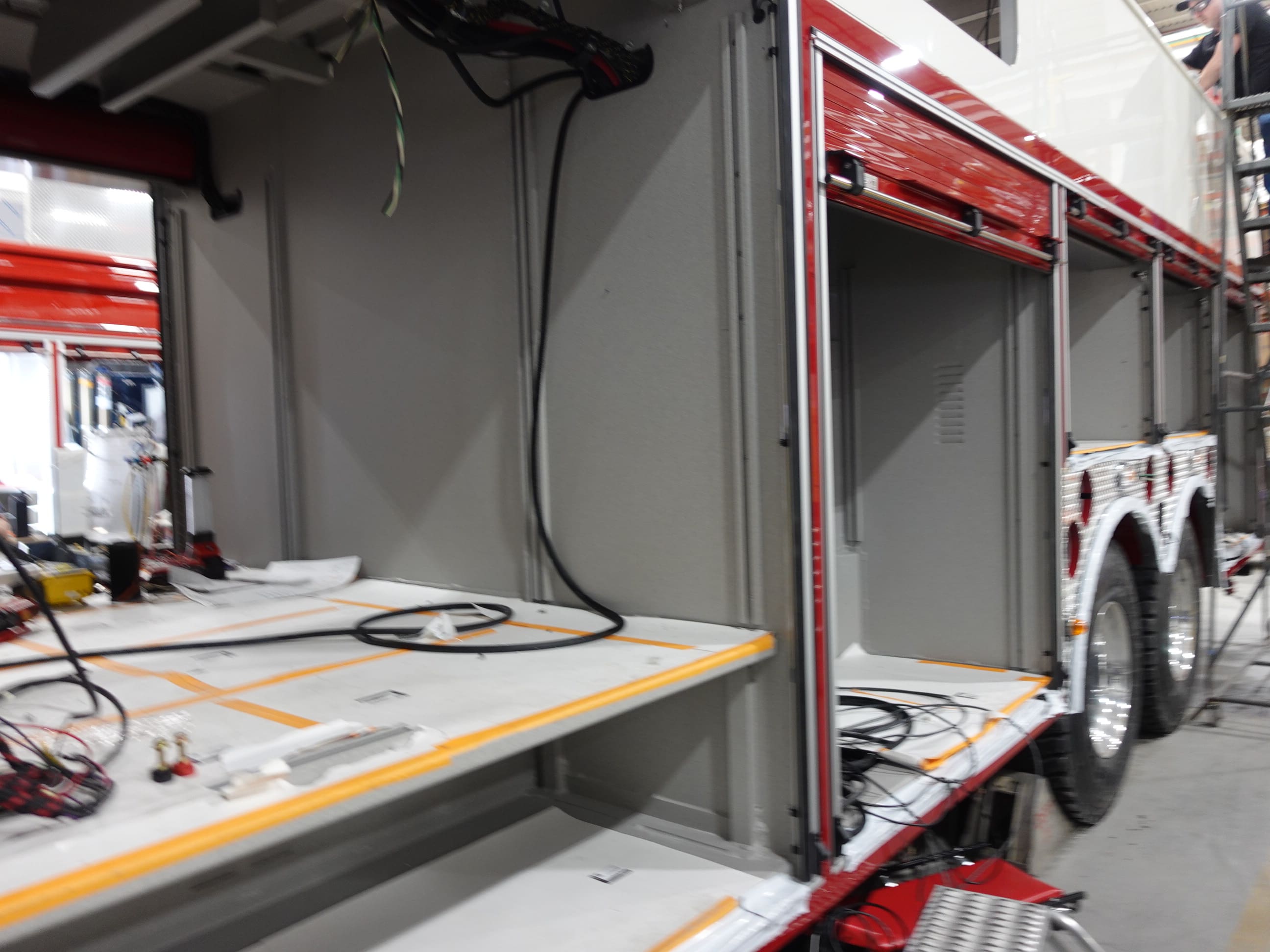

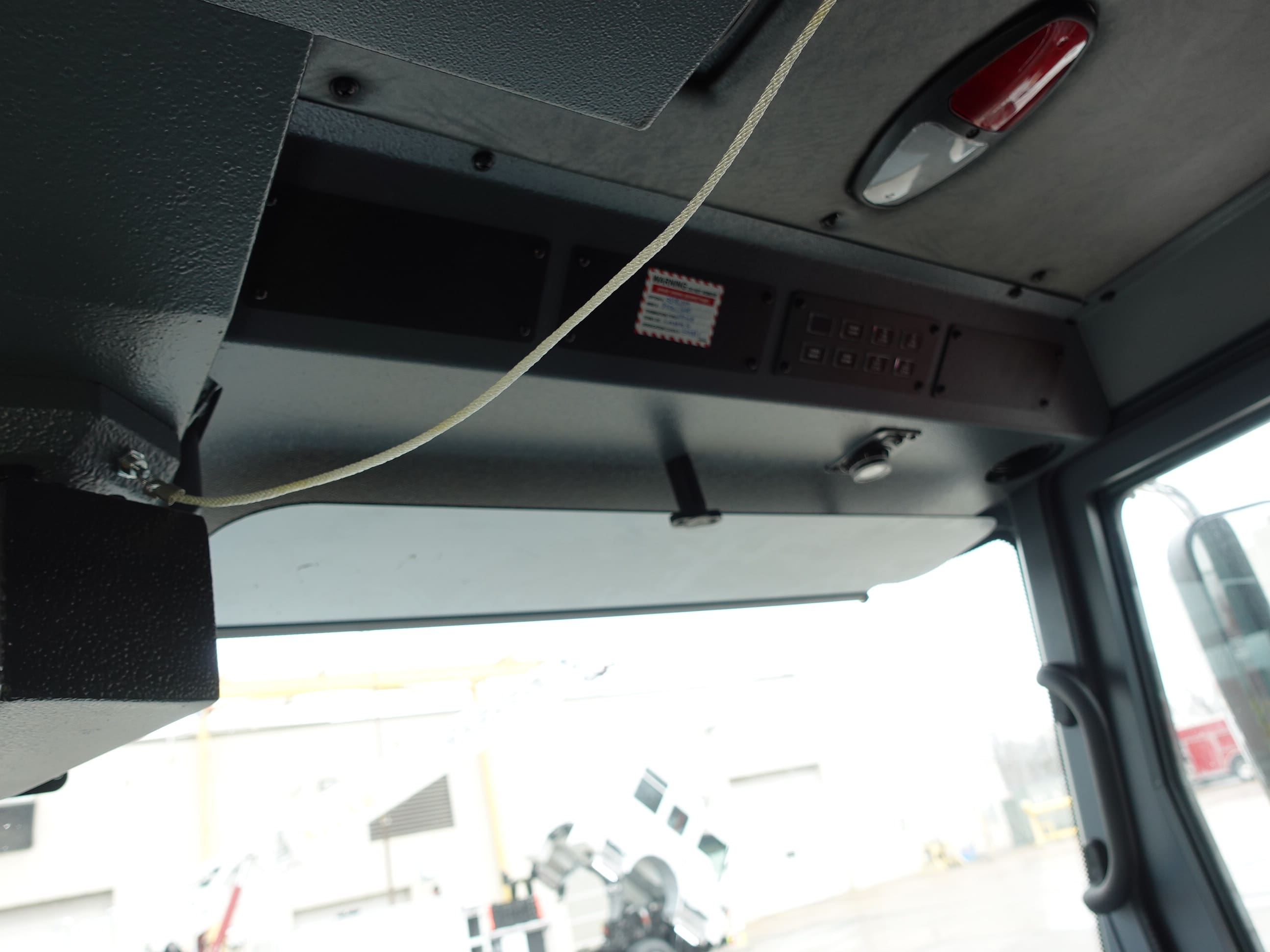

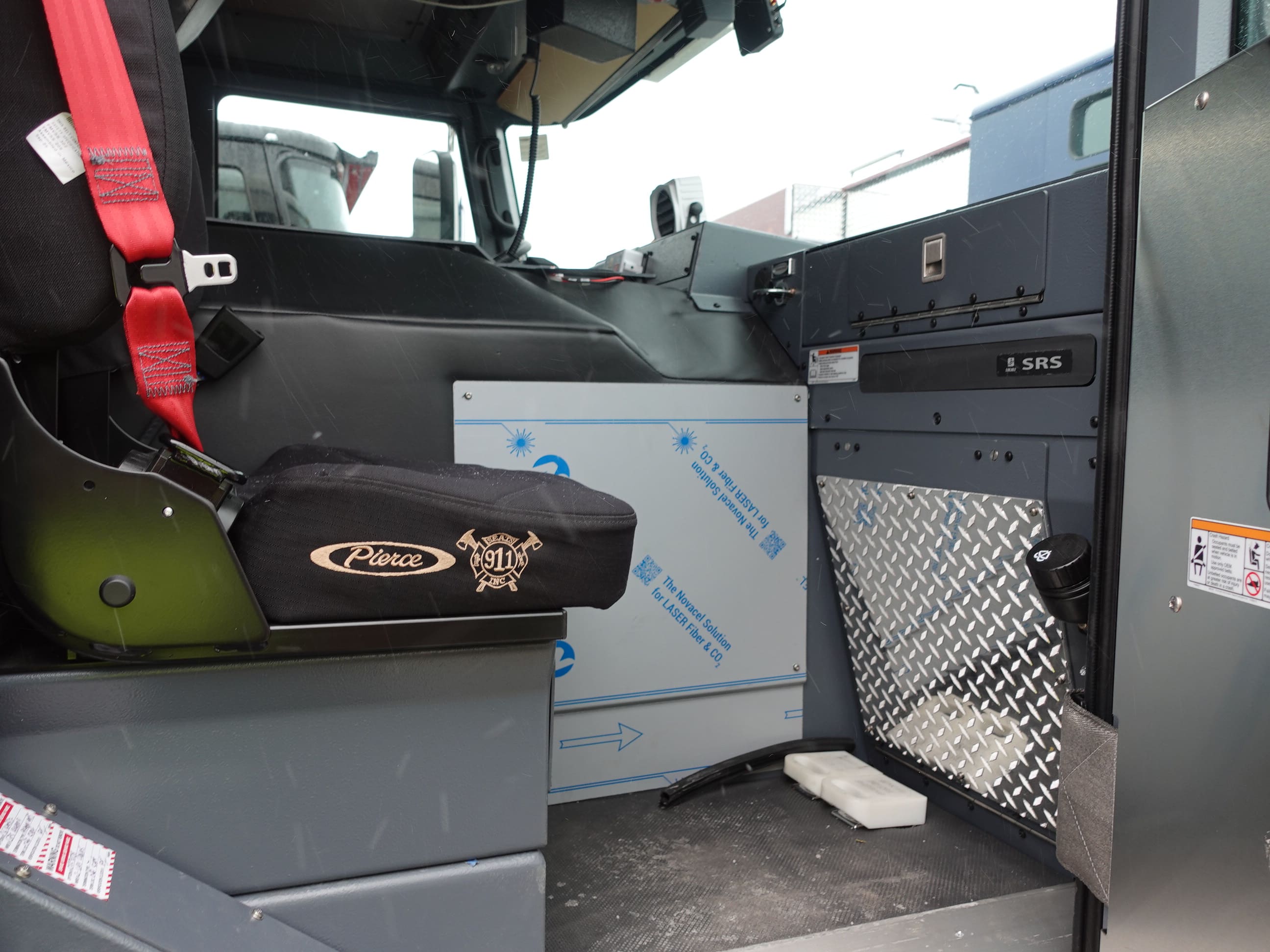

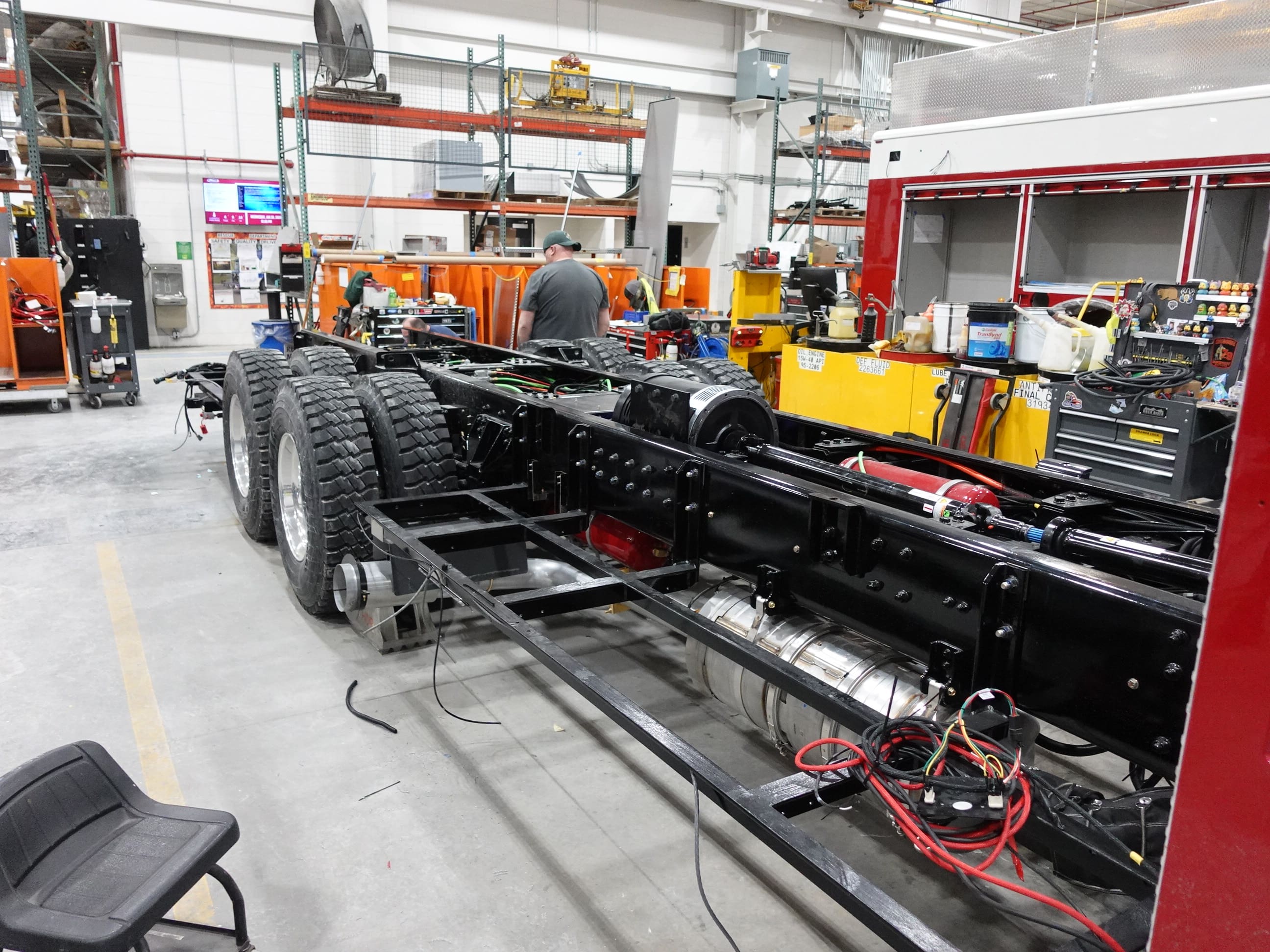

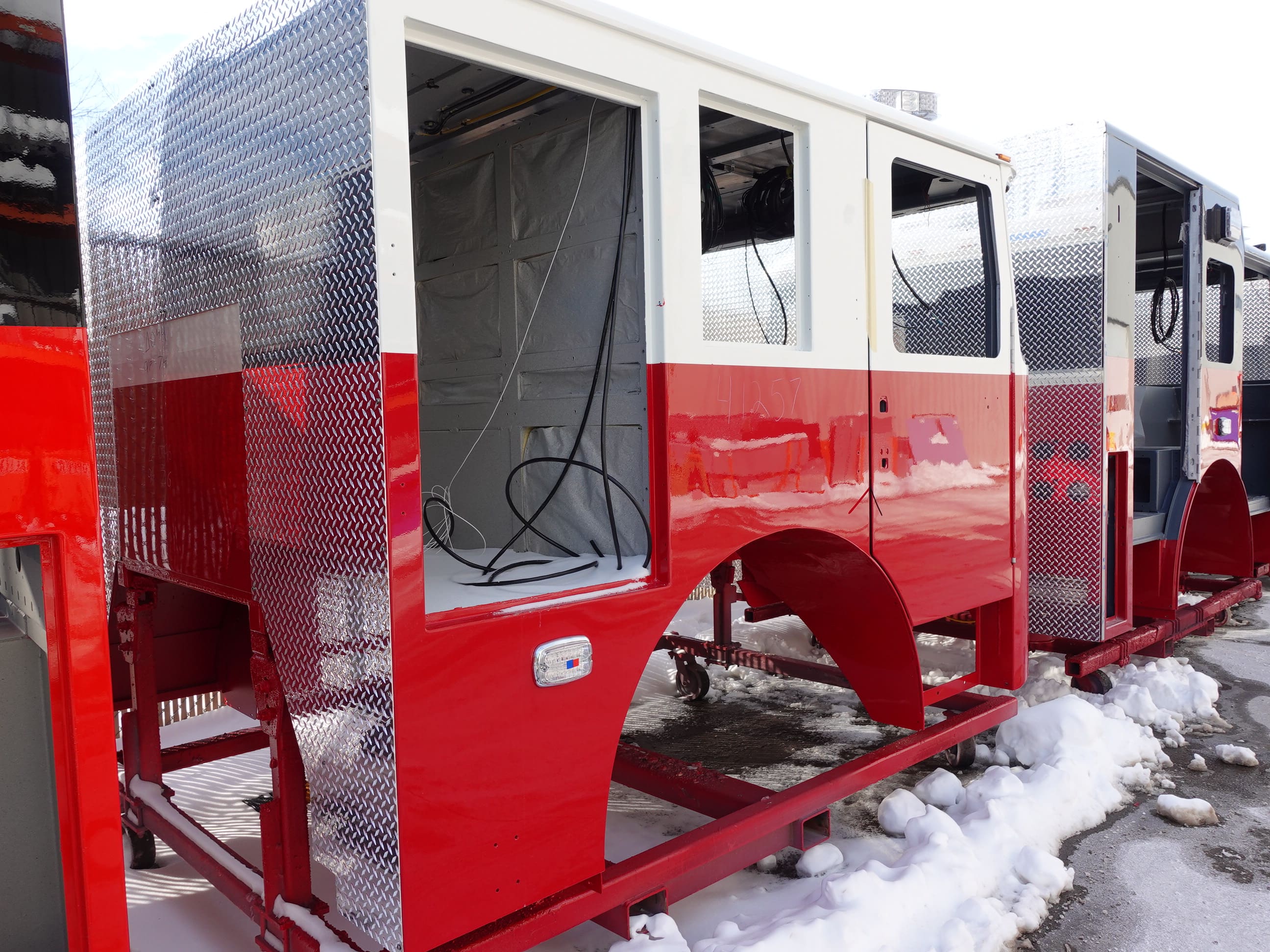

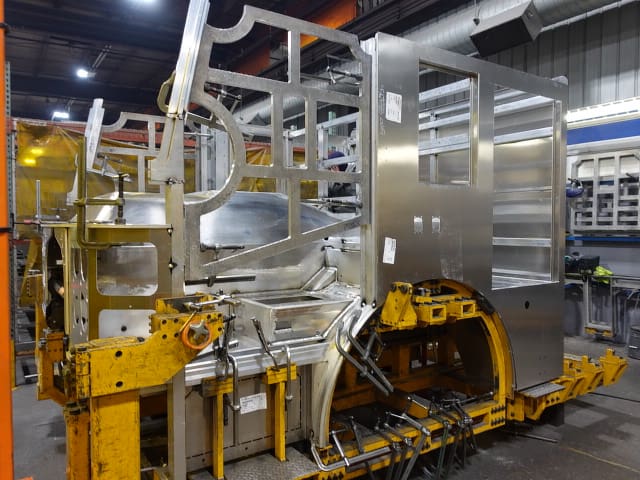

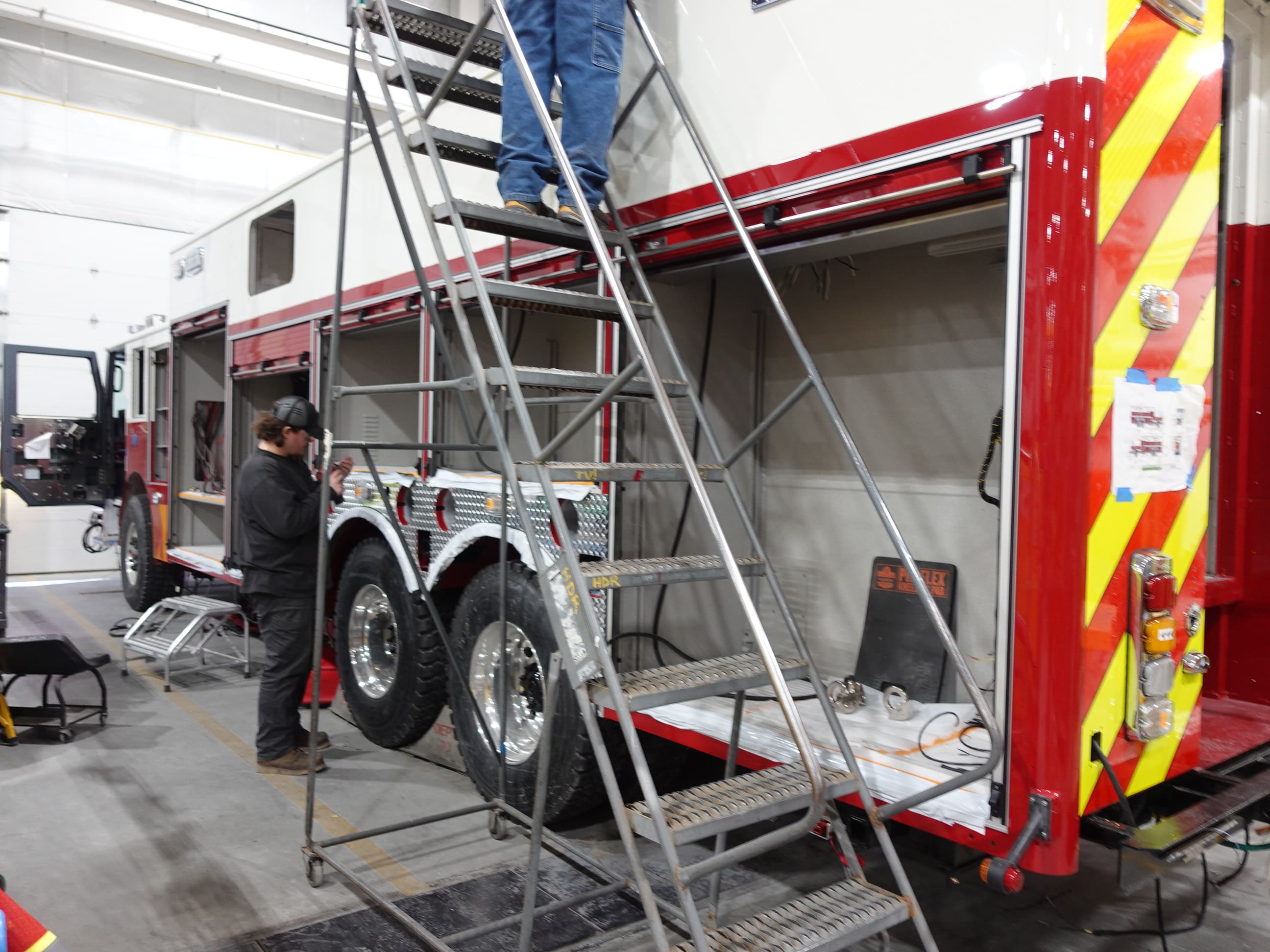

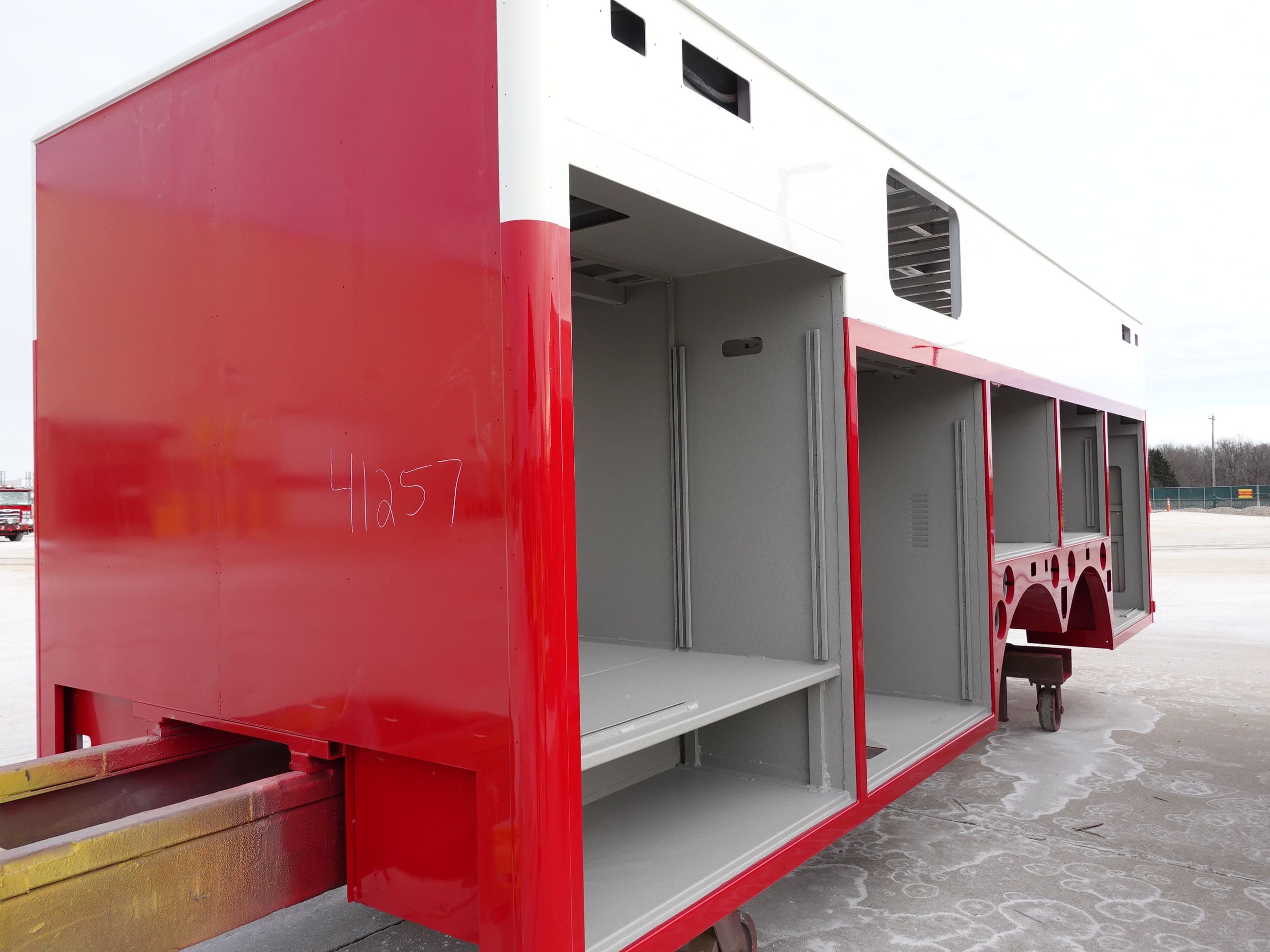

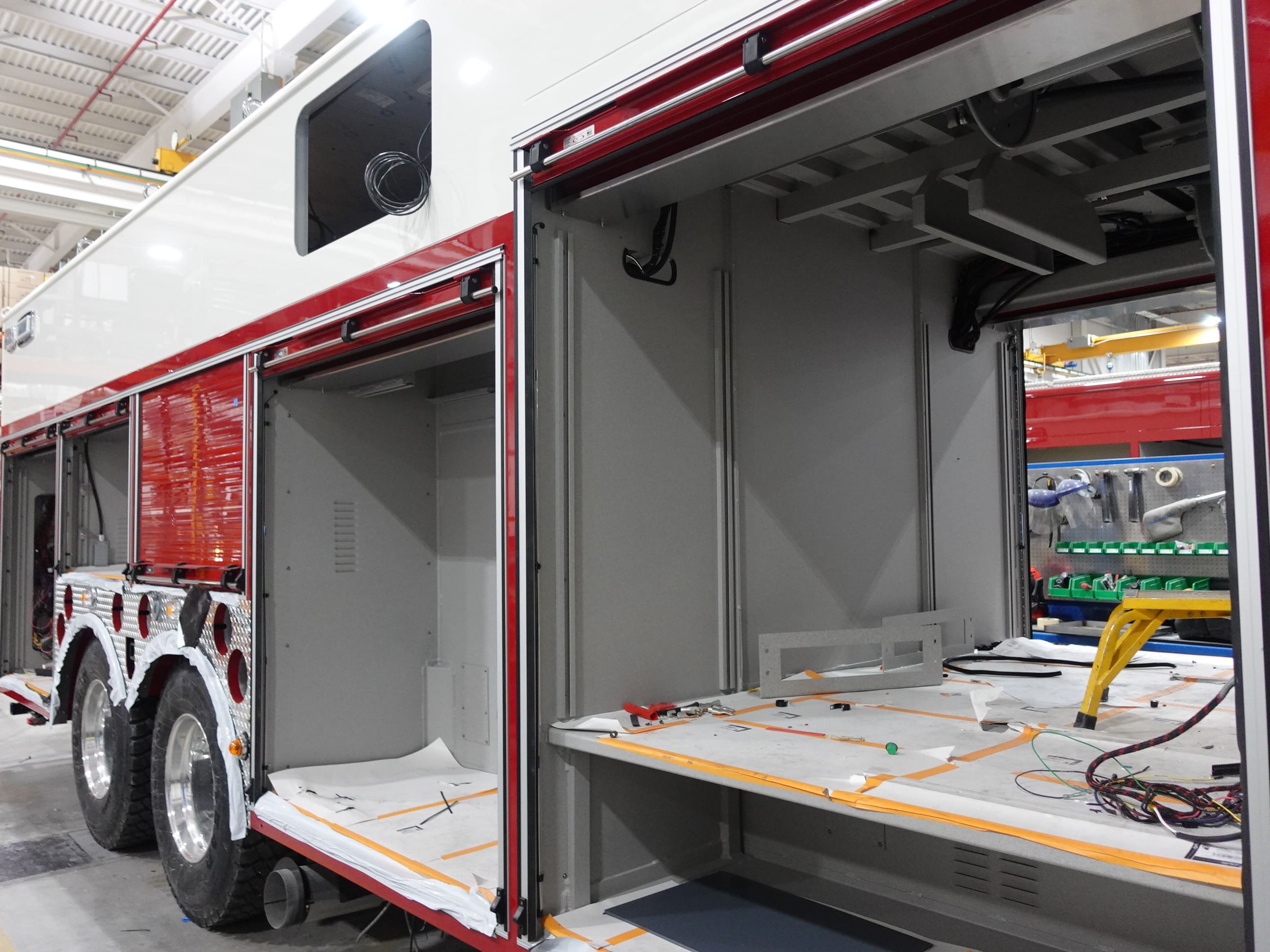

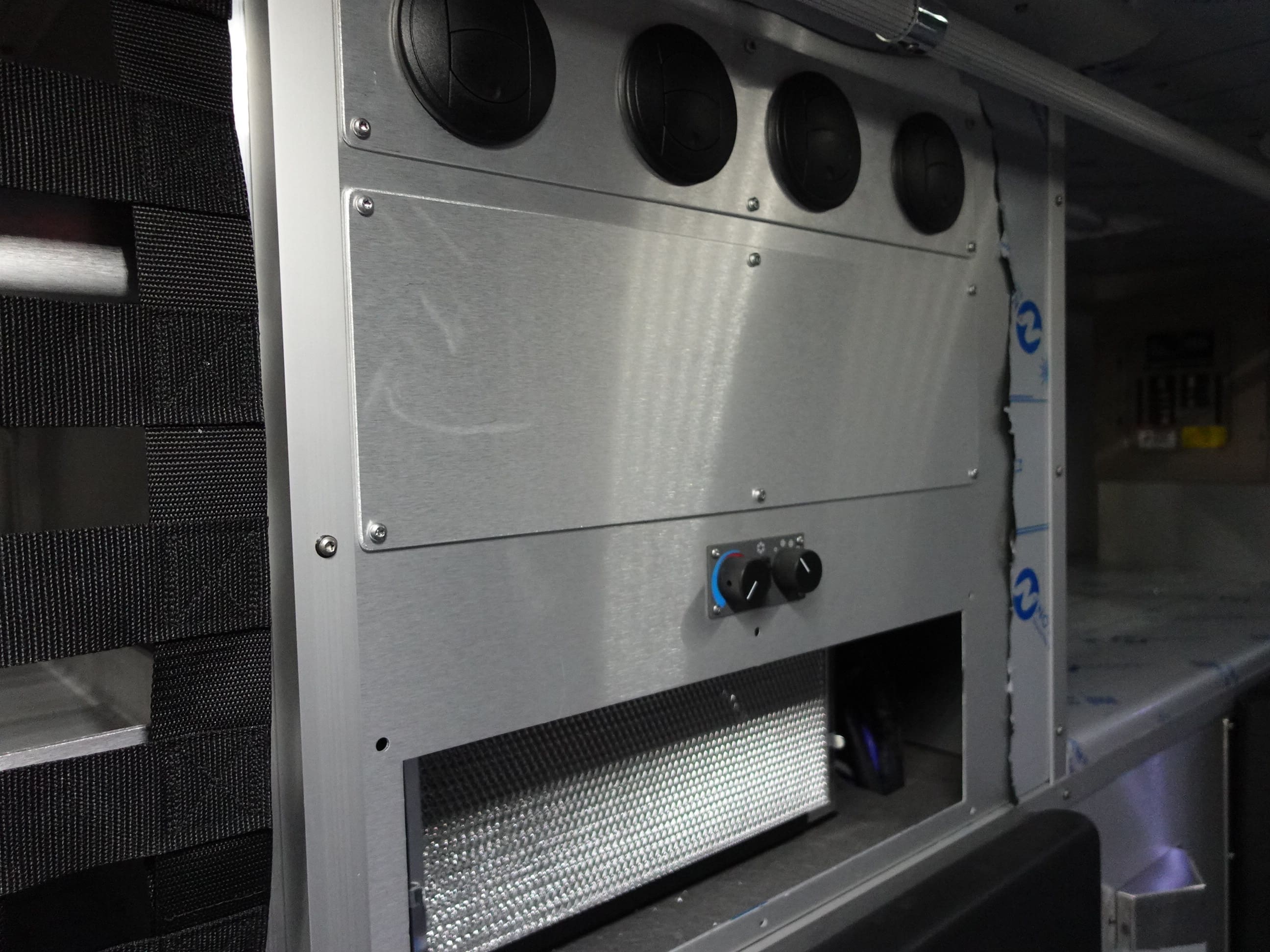

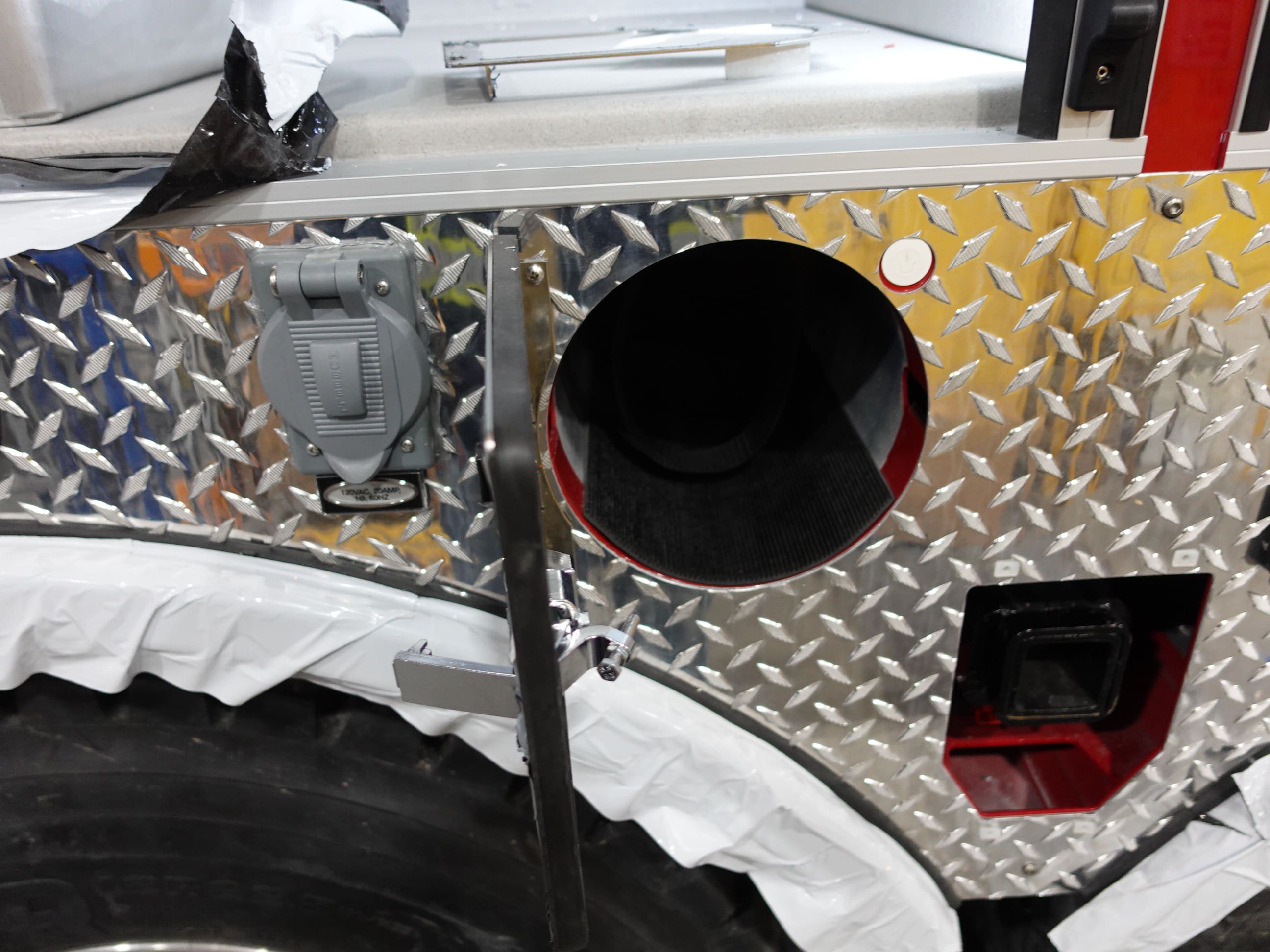

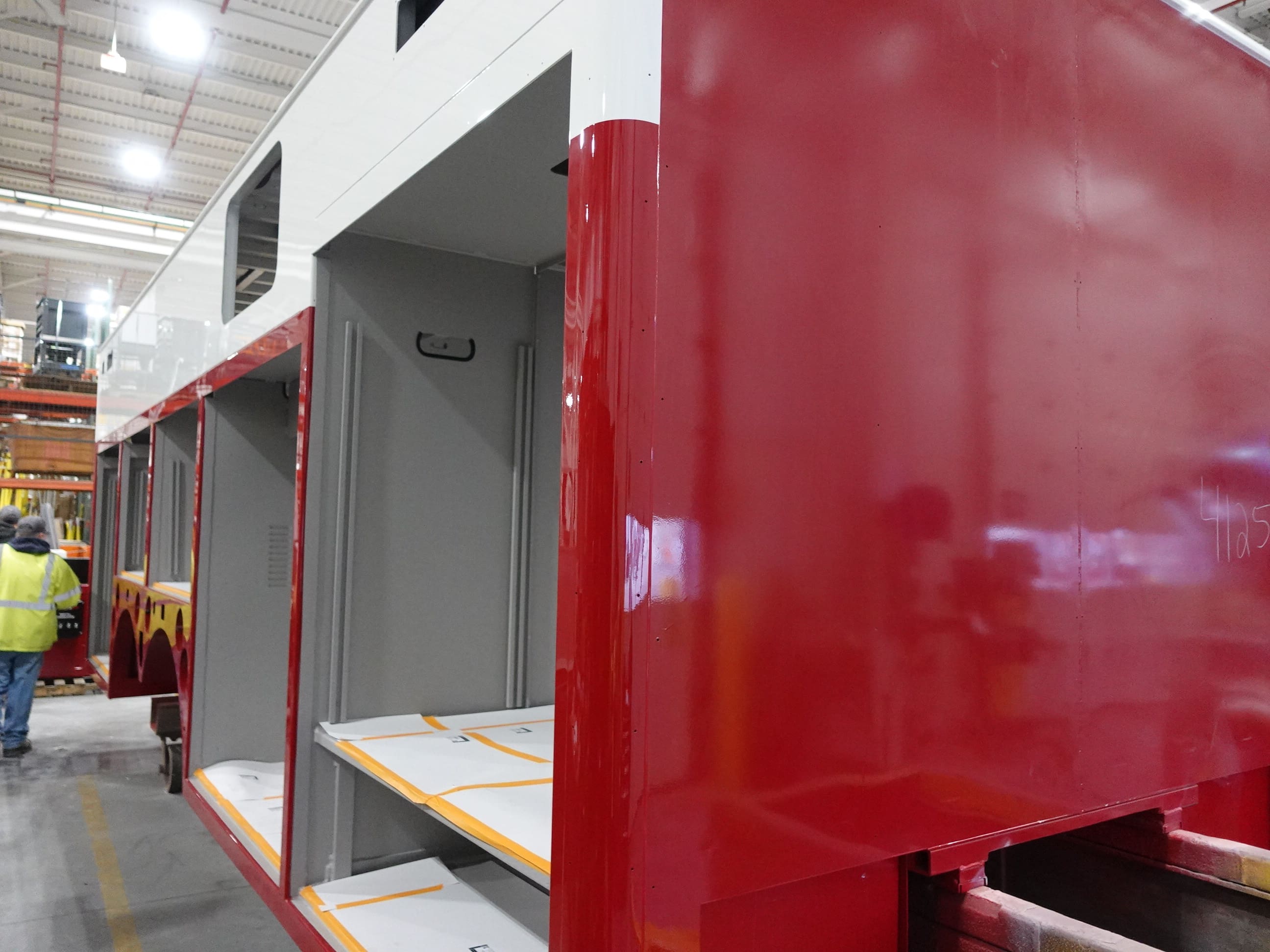

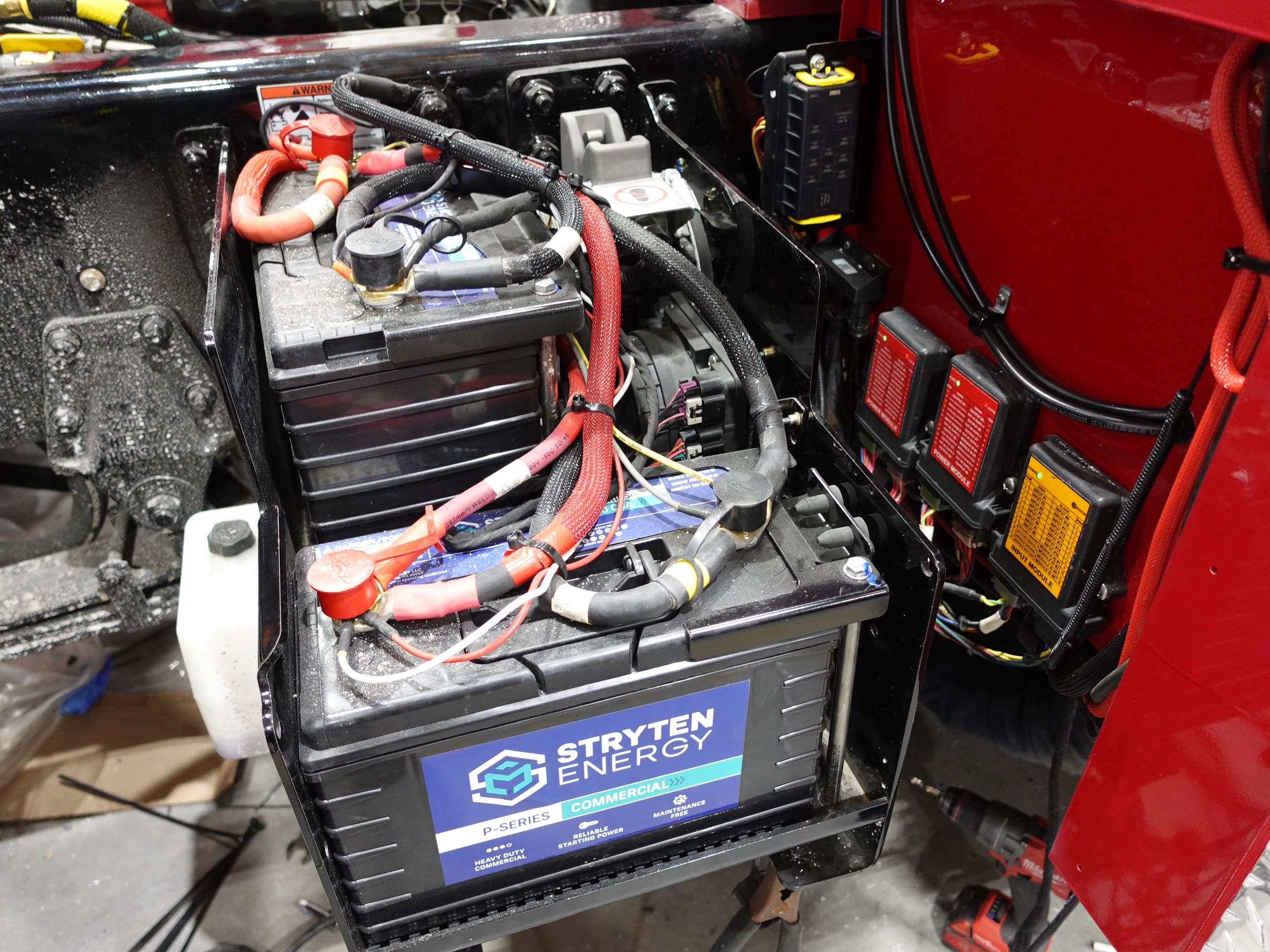

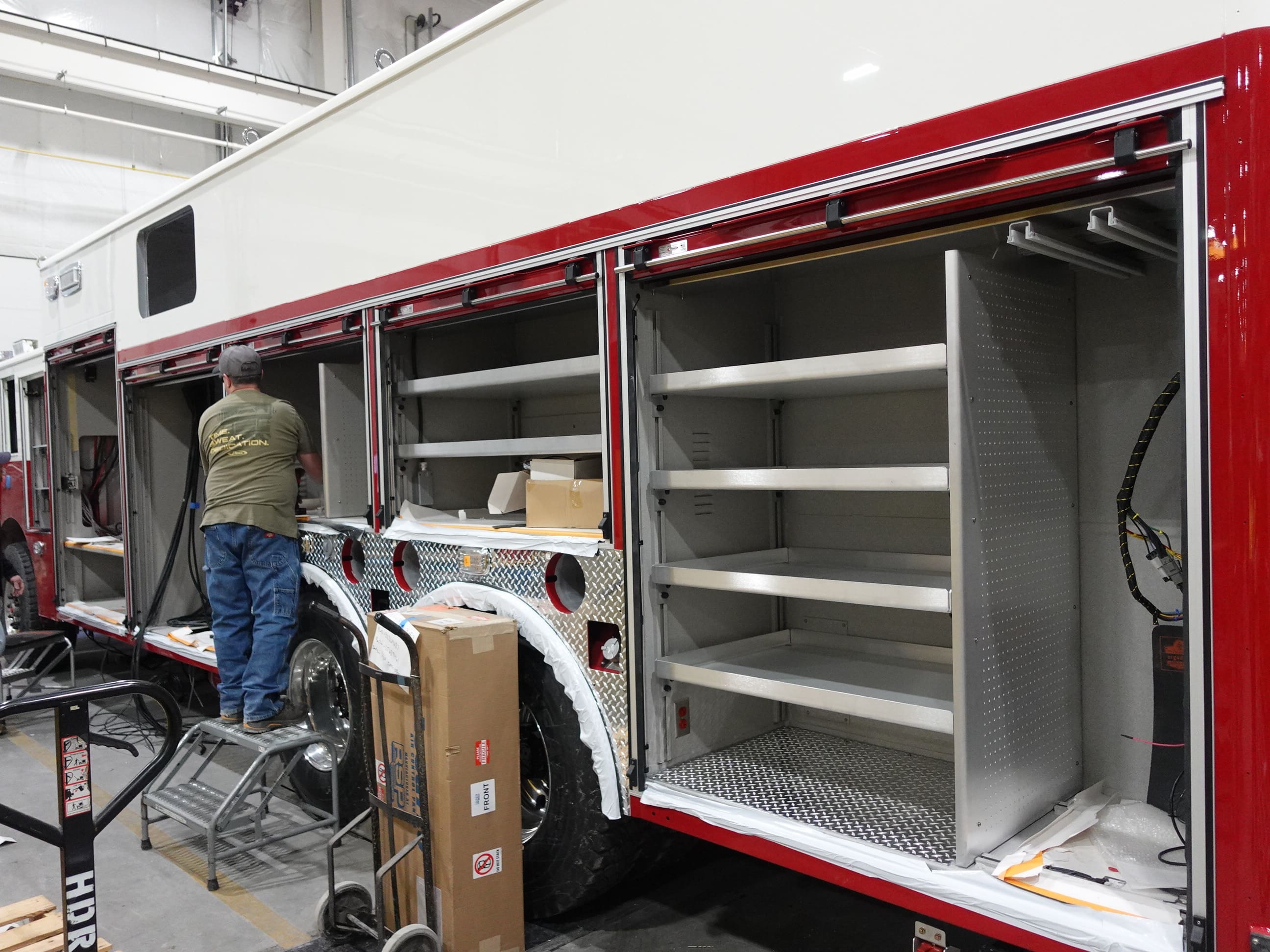

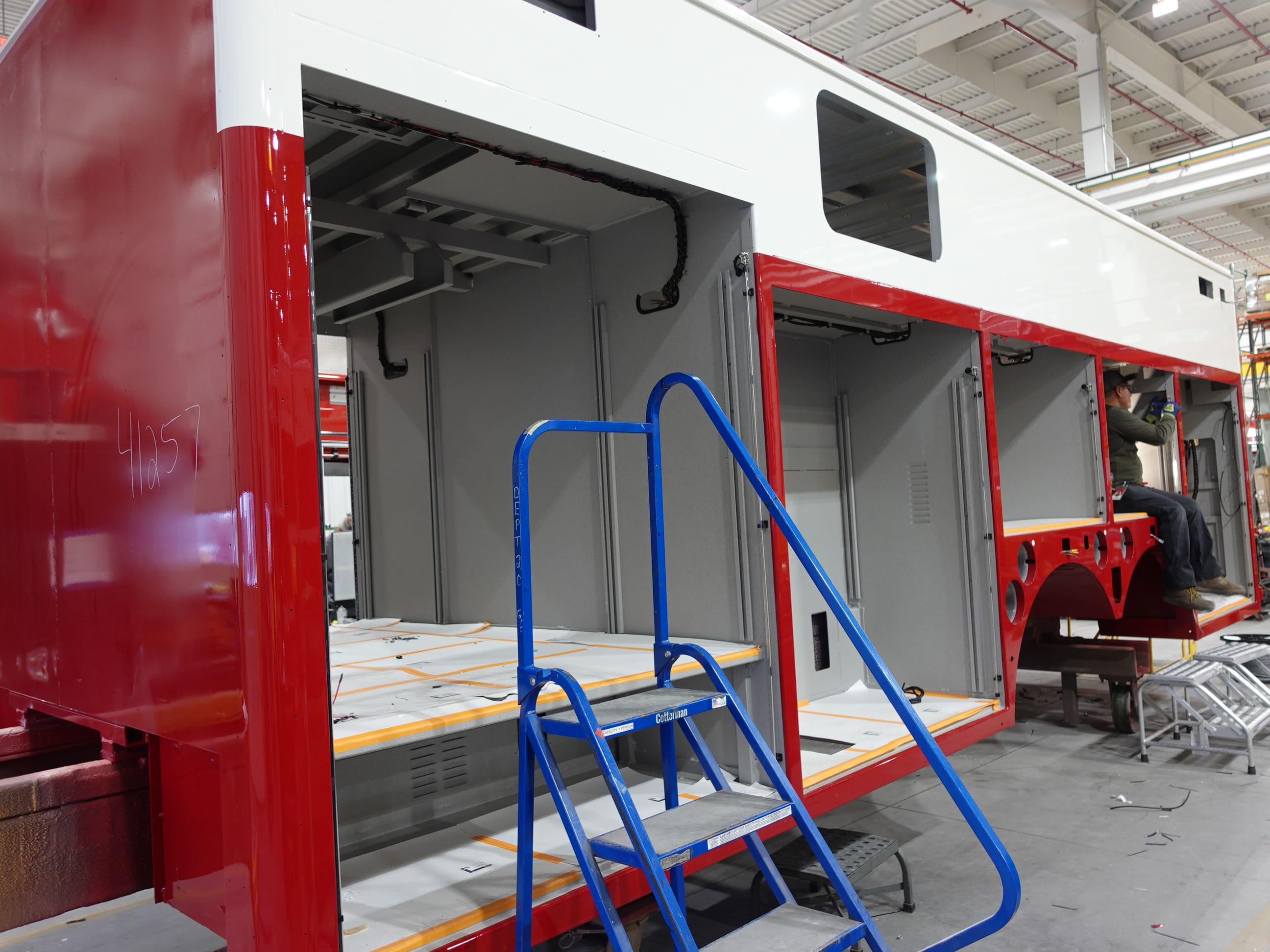

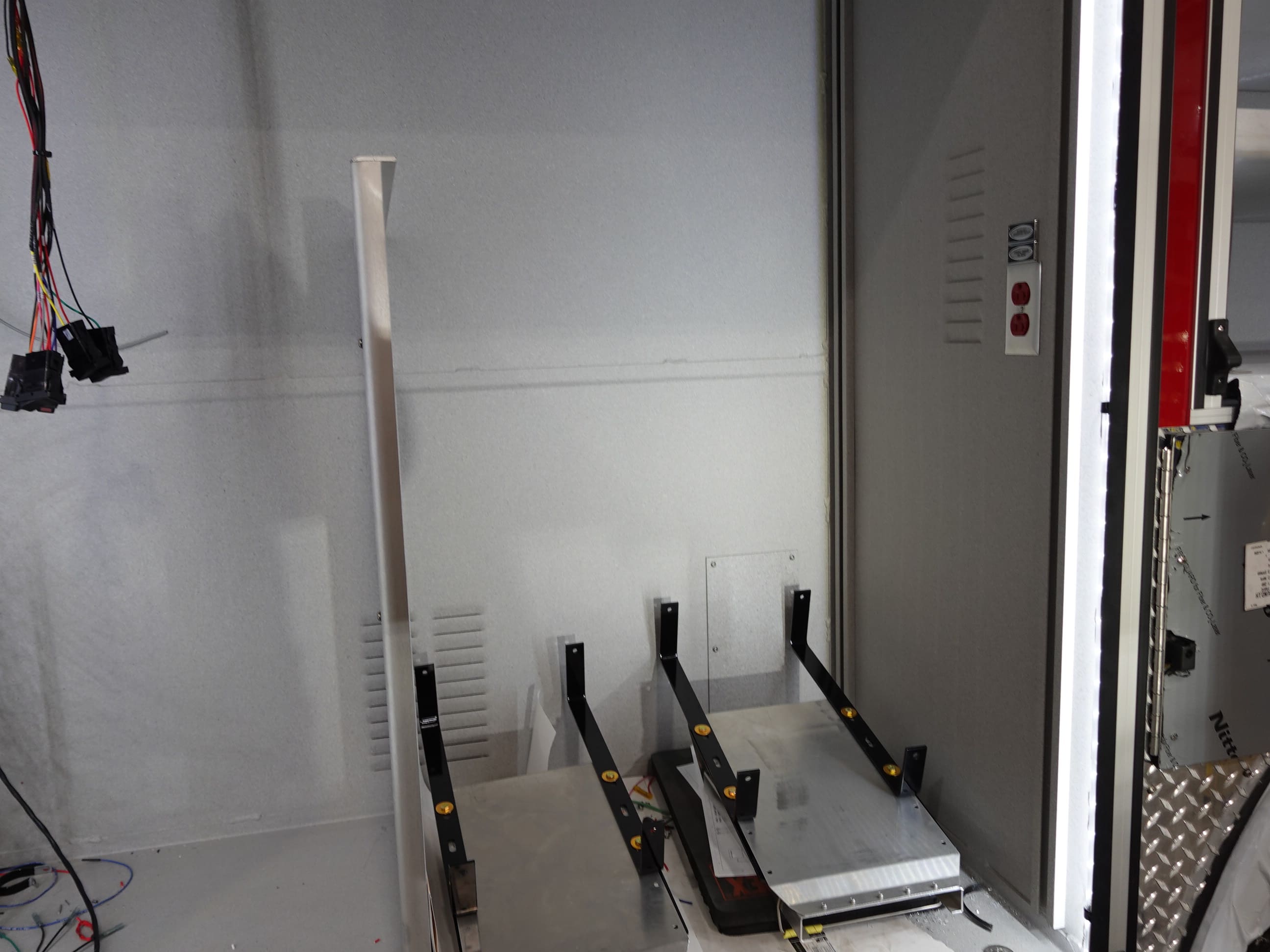

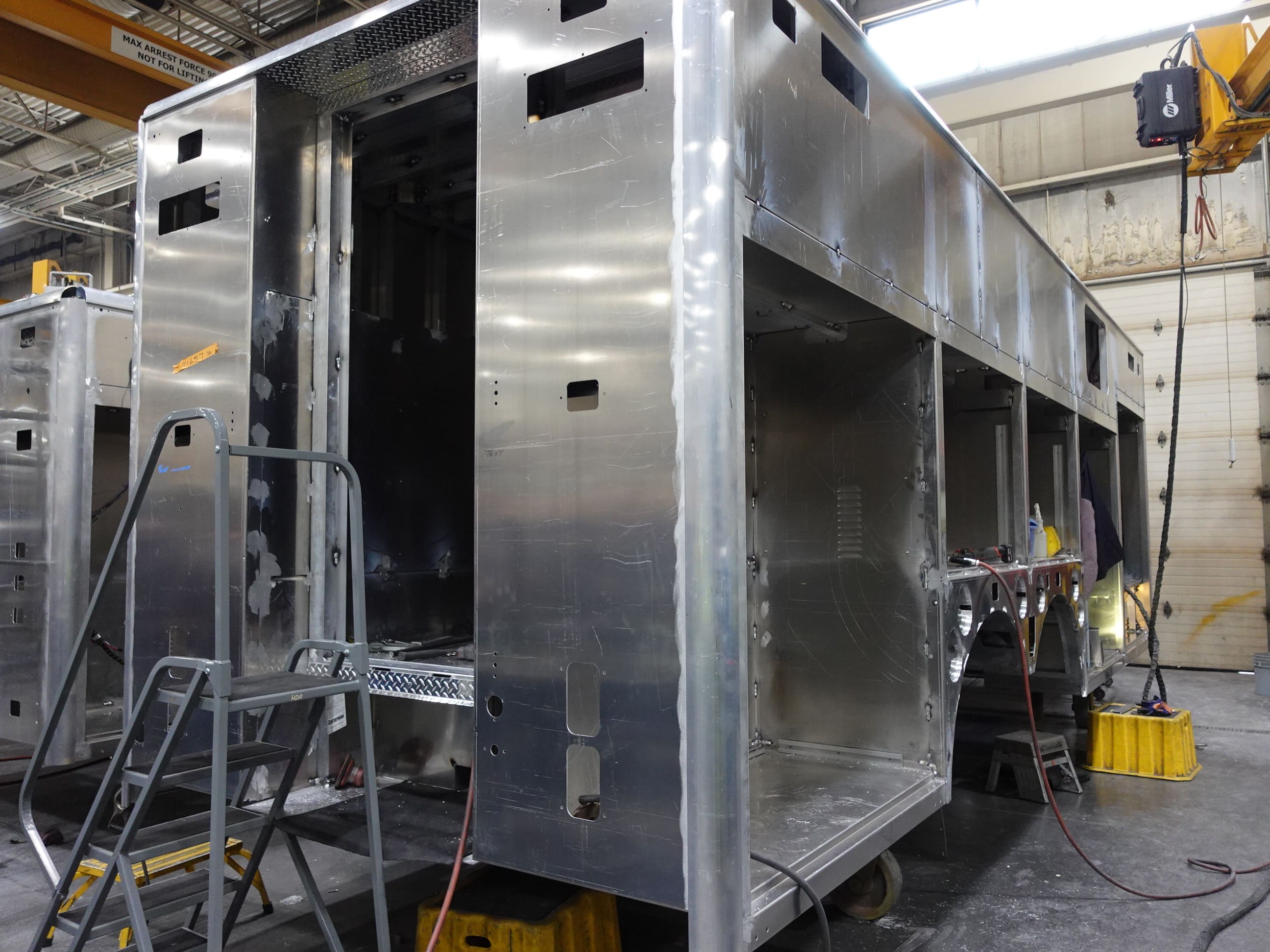

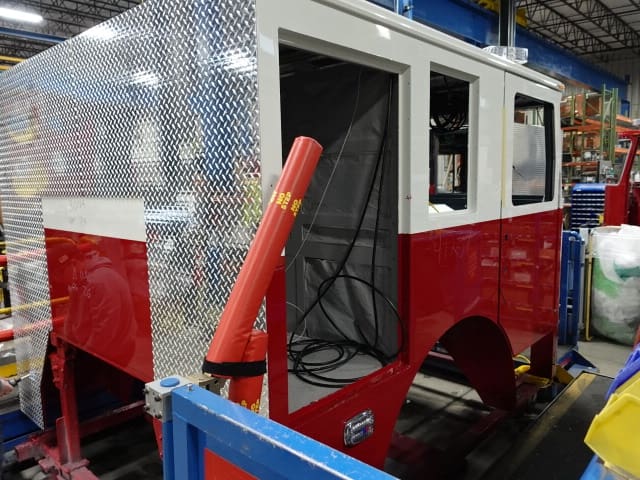

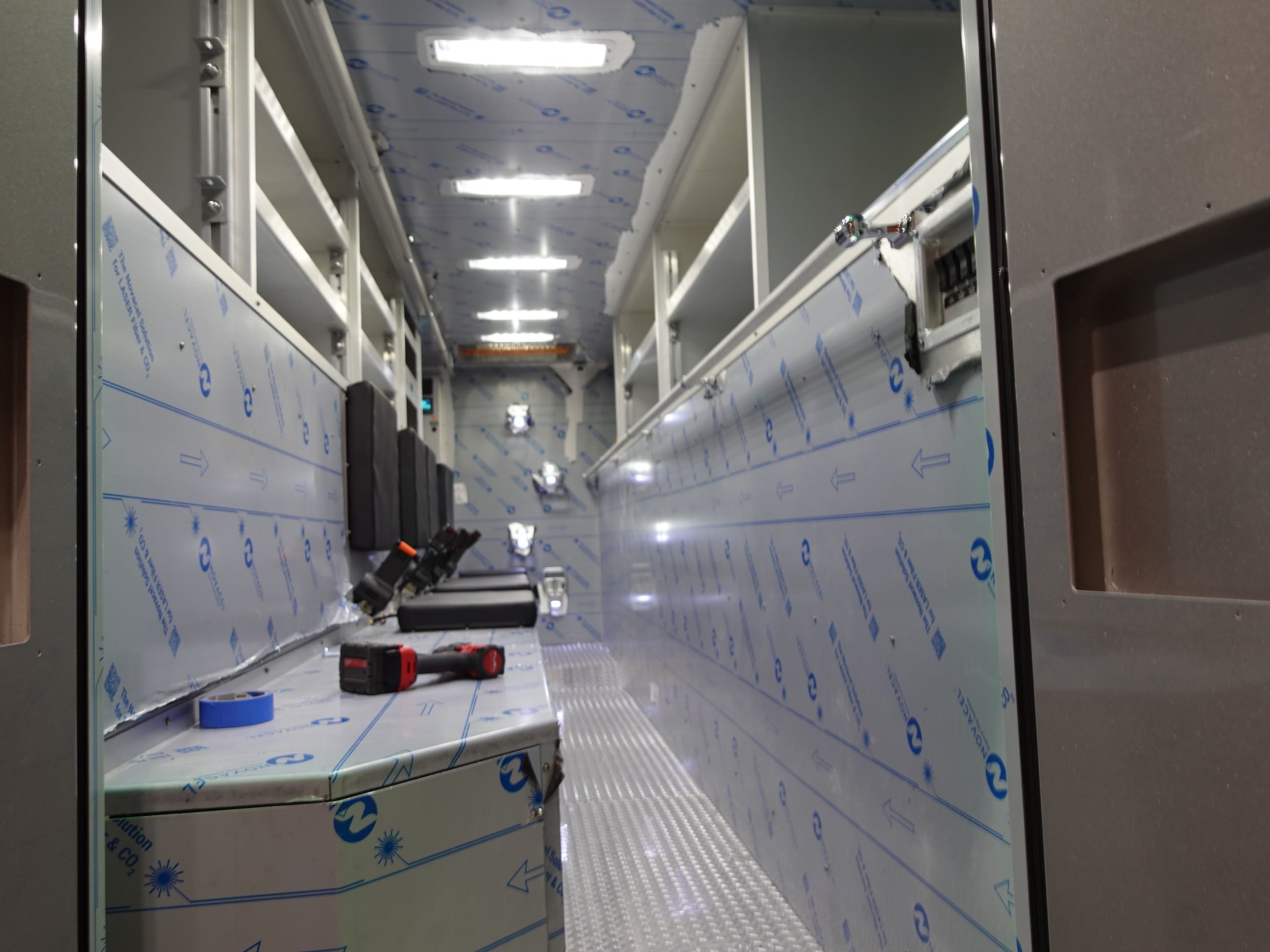

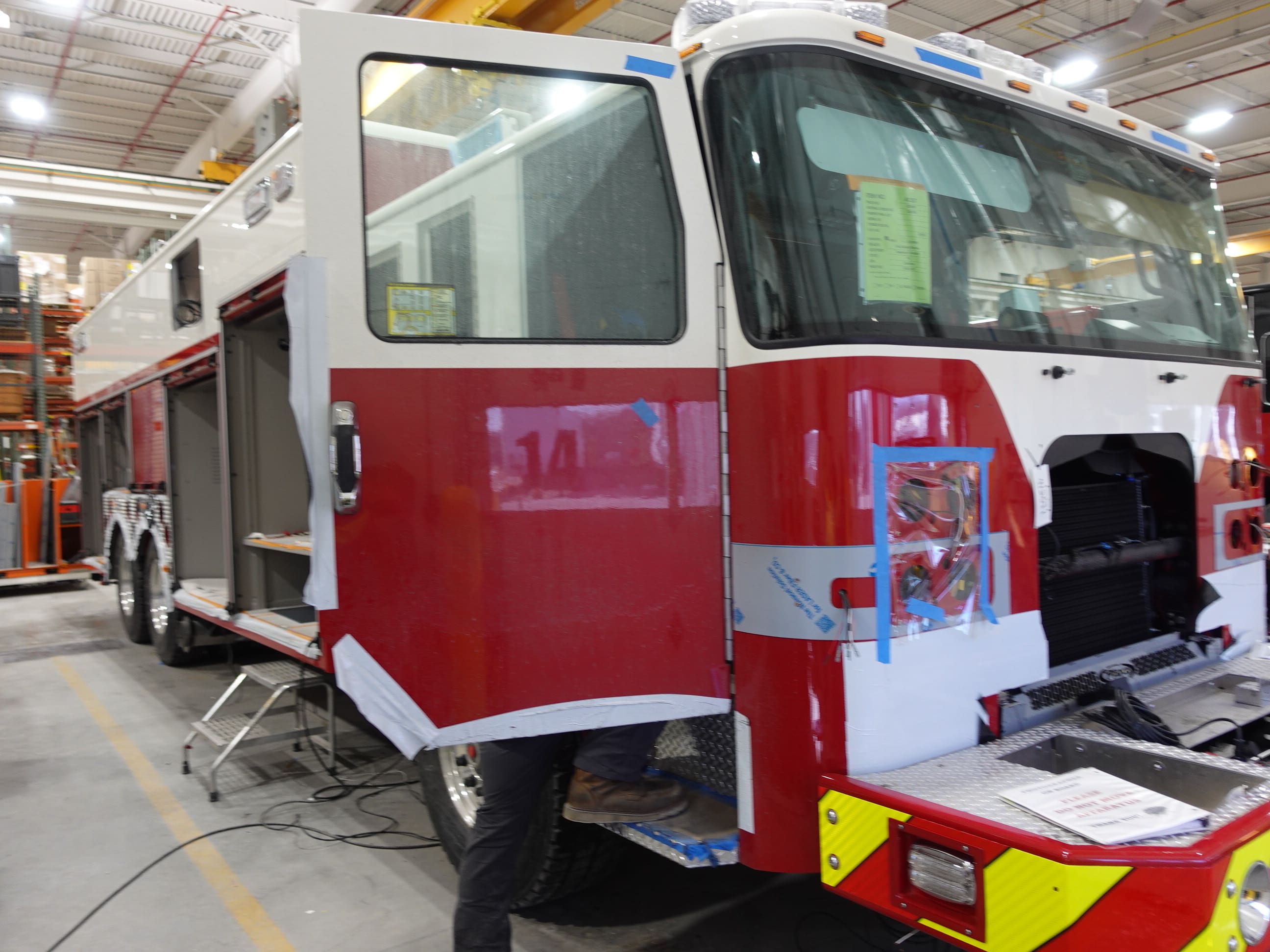

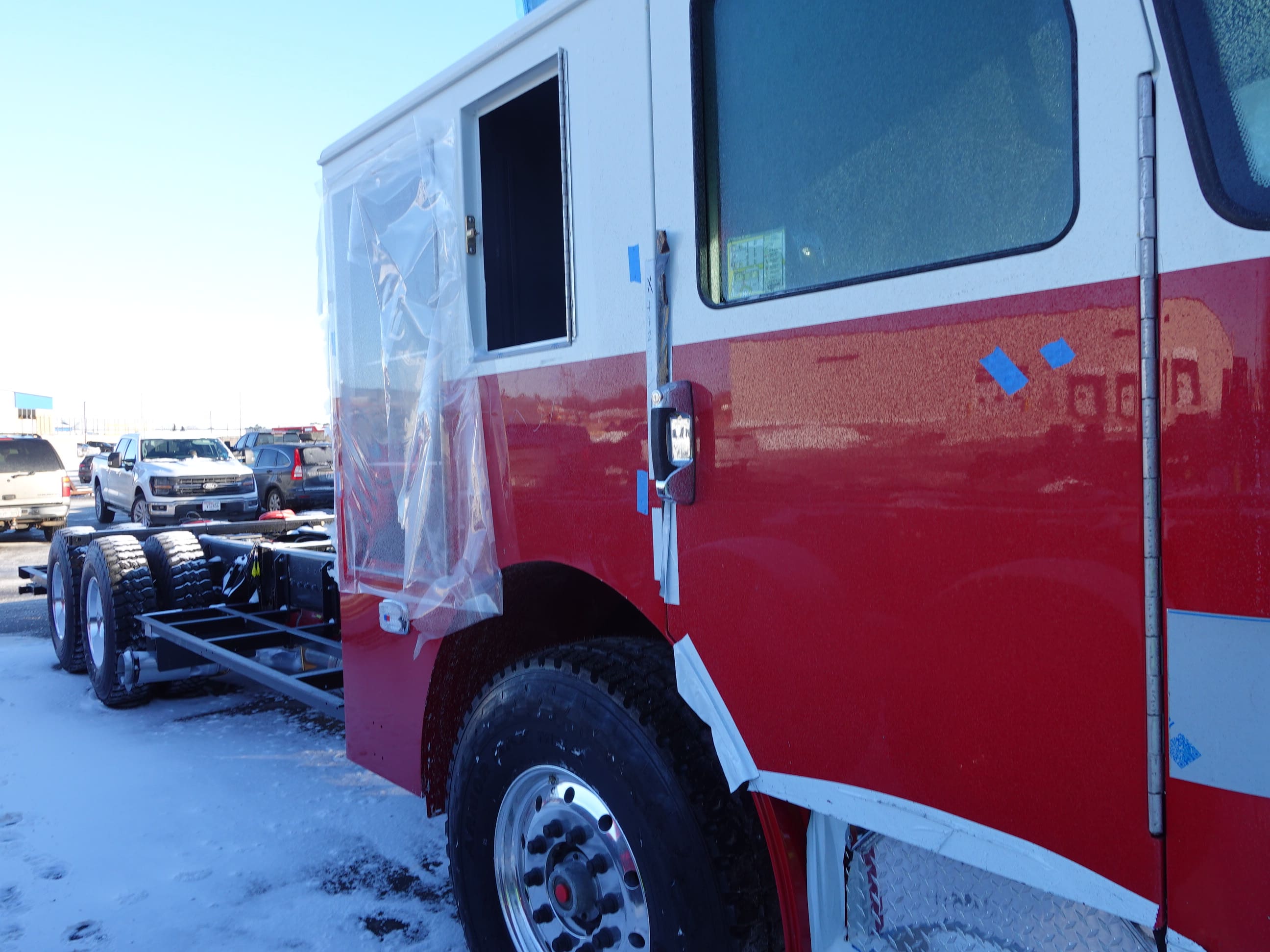

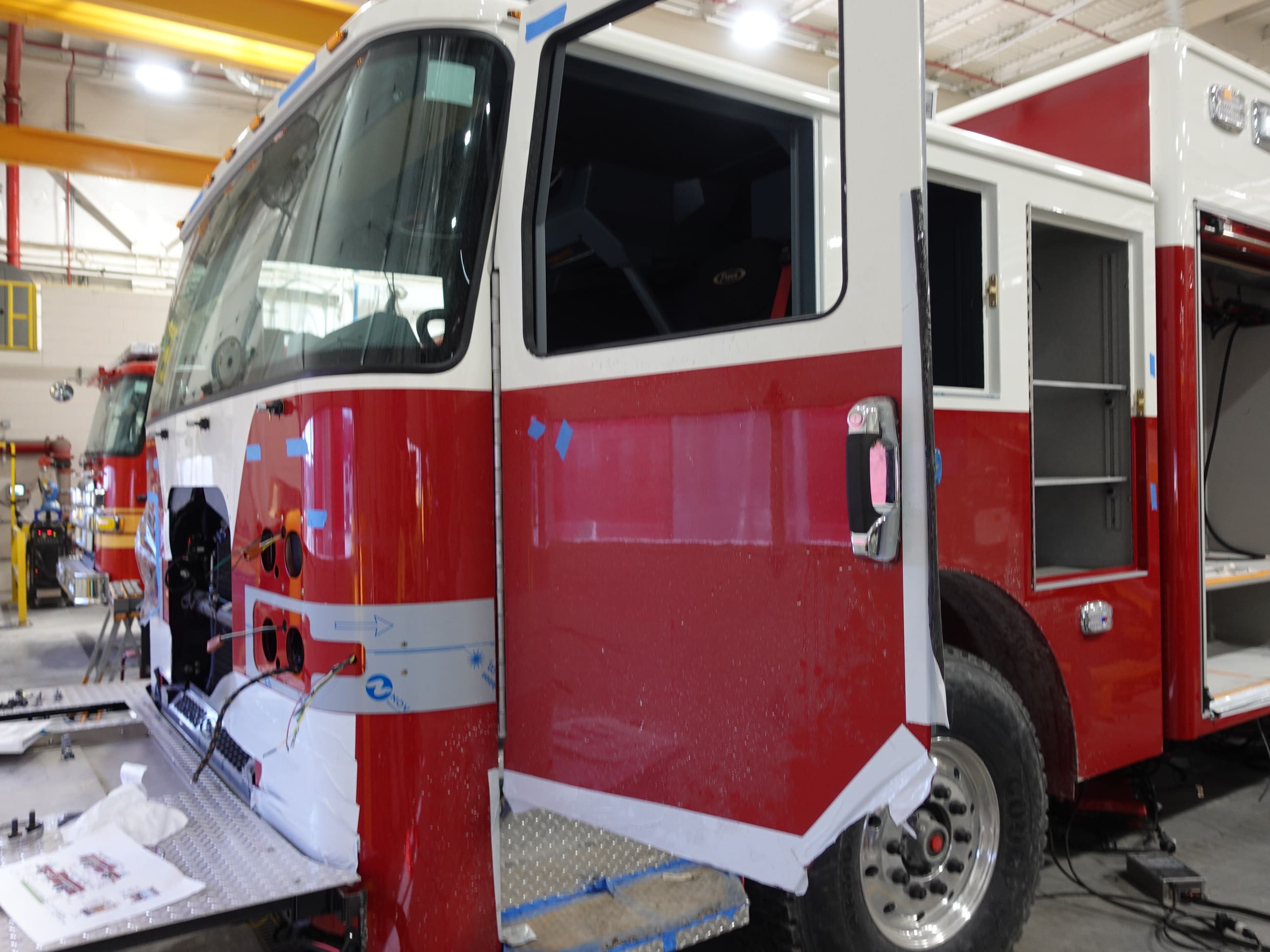

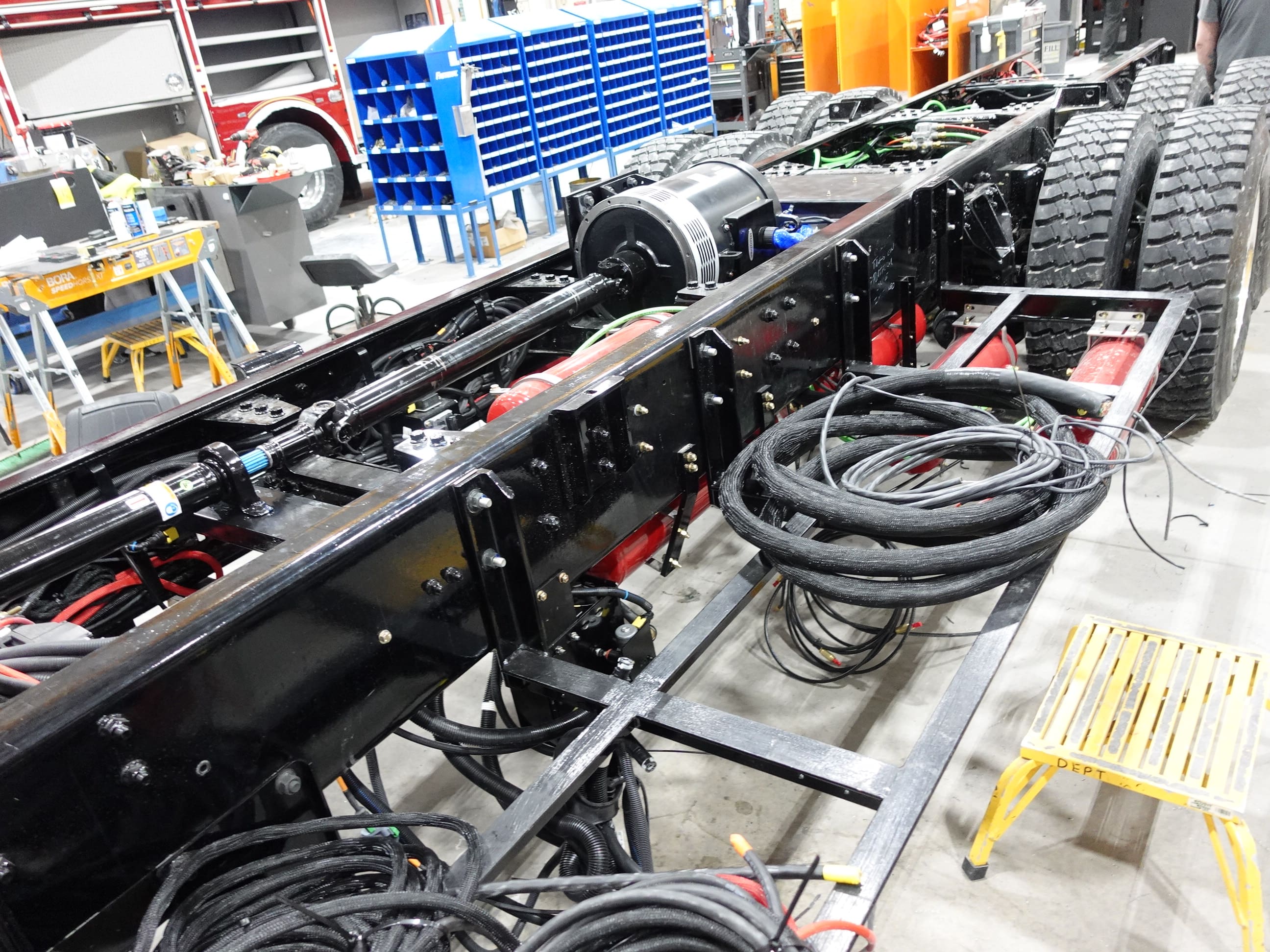

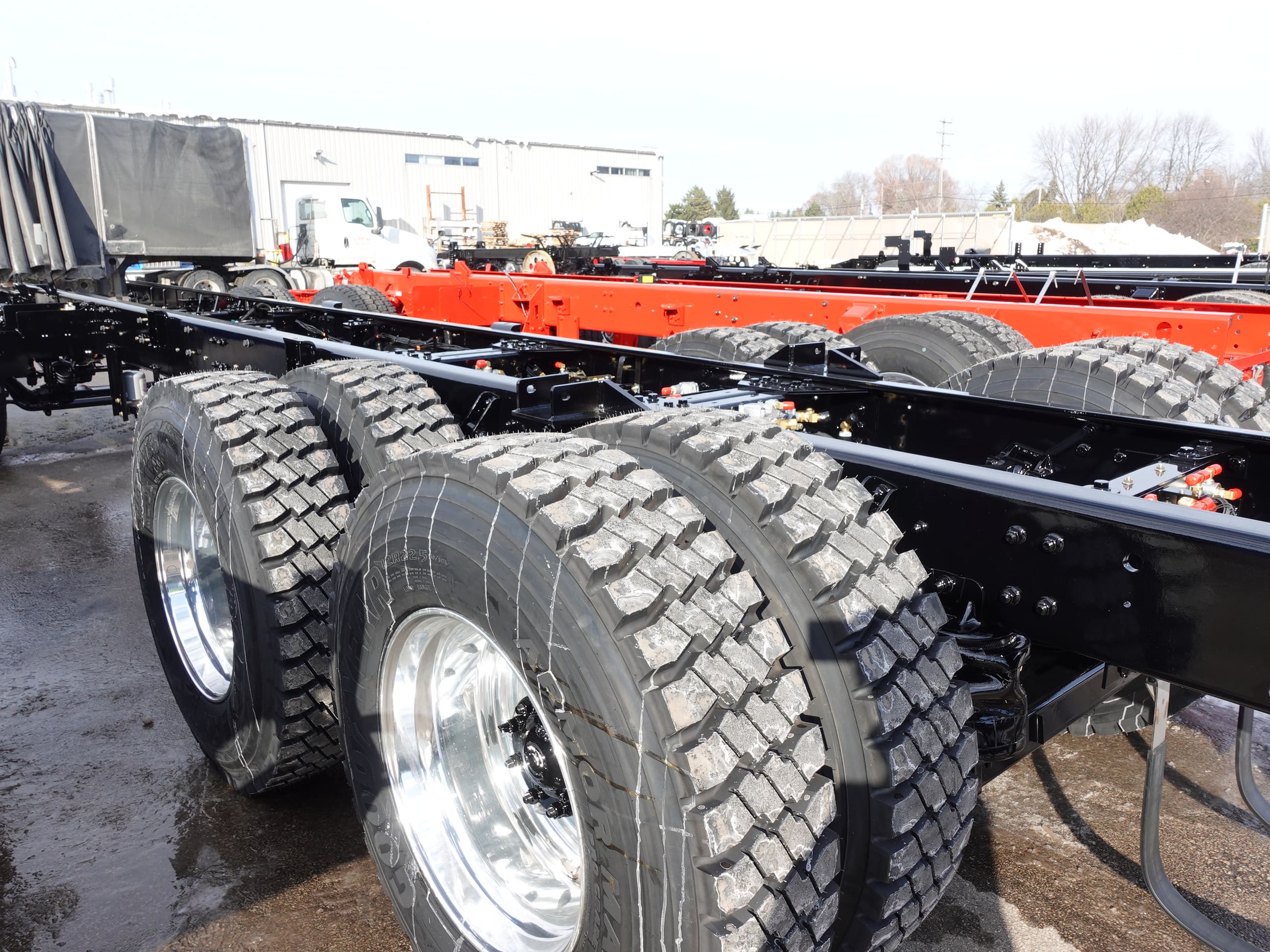

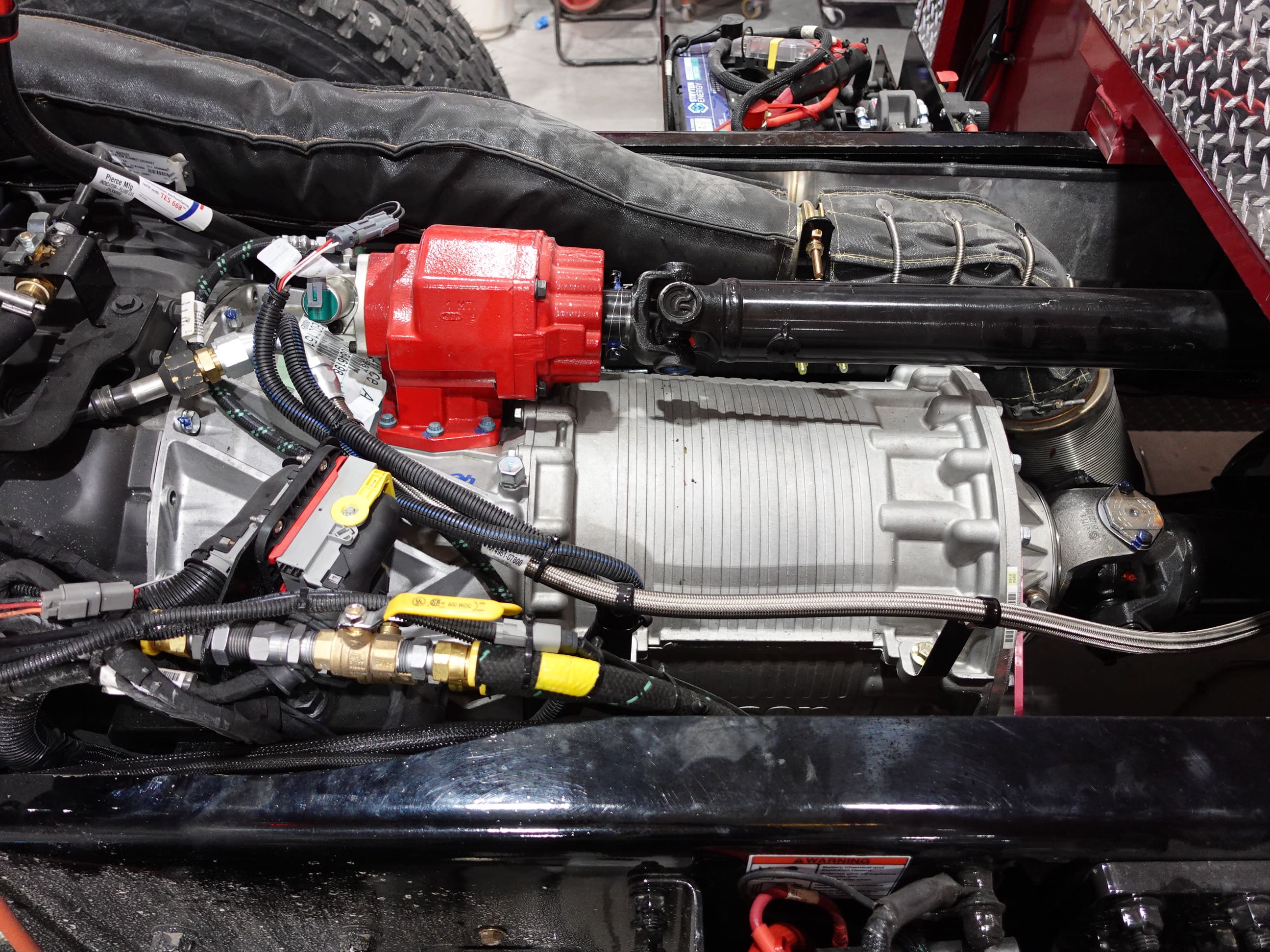

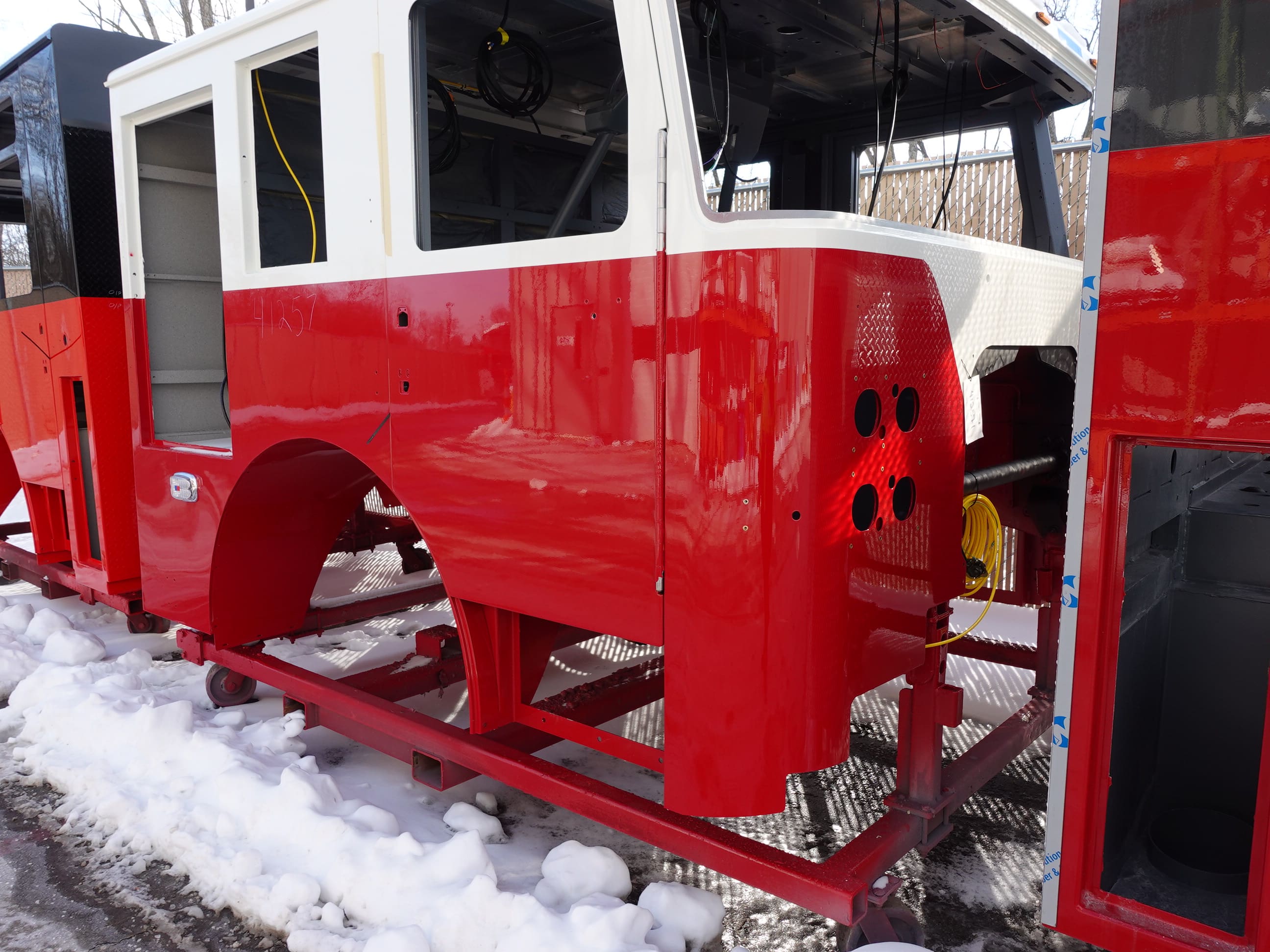

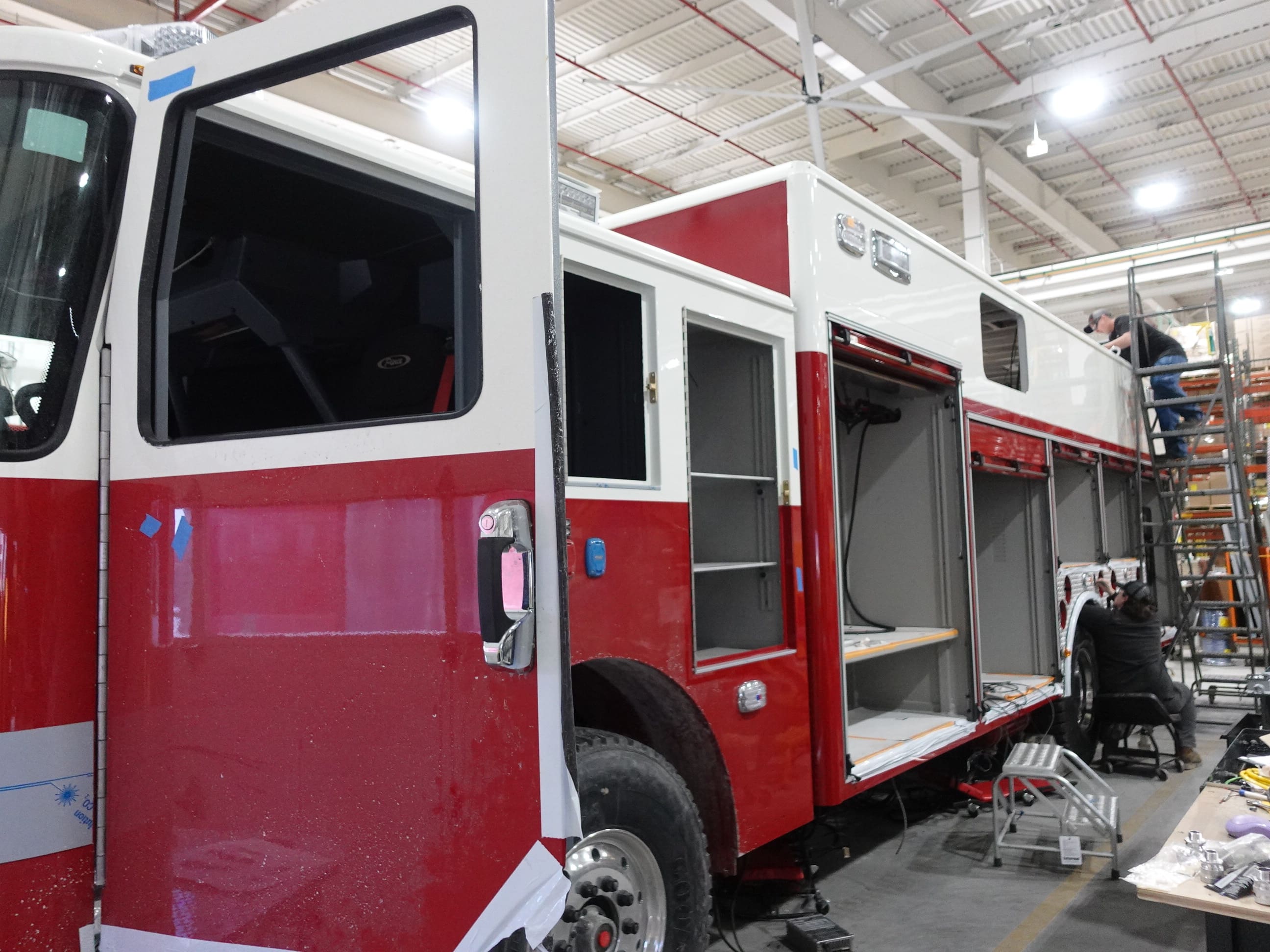

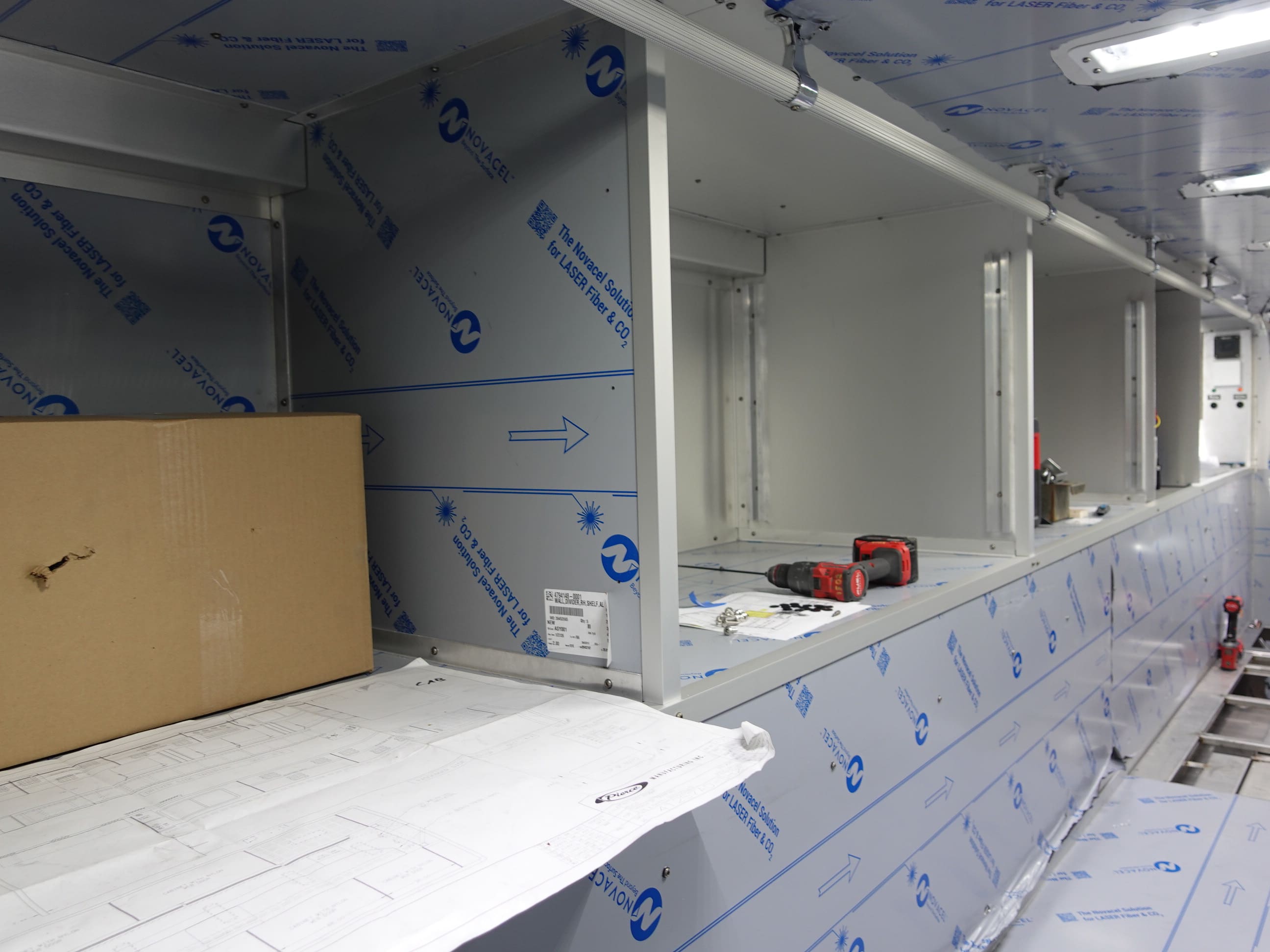

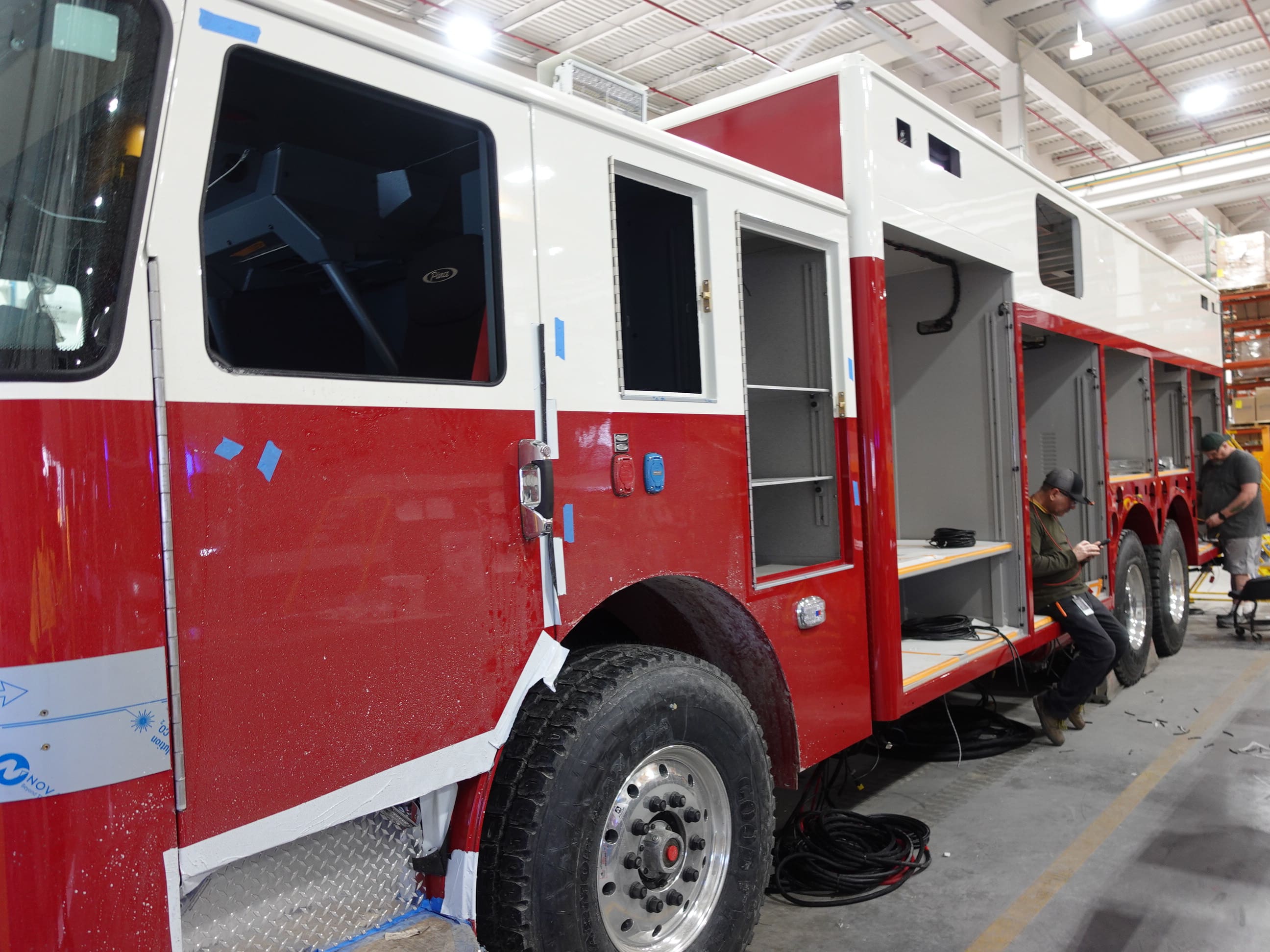

In this report, the chassis continued assembly while the body continued initial assembly followed by body installation.

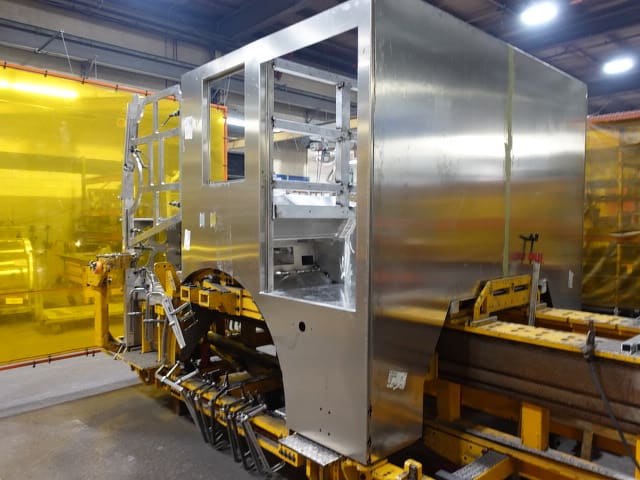

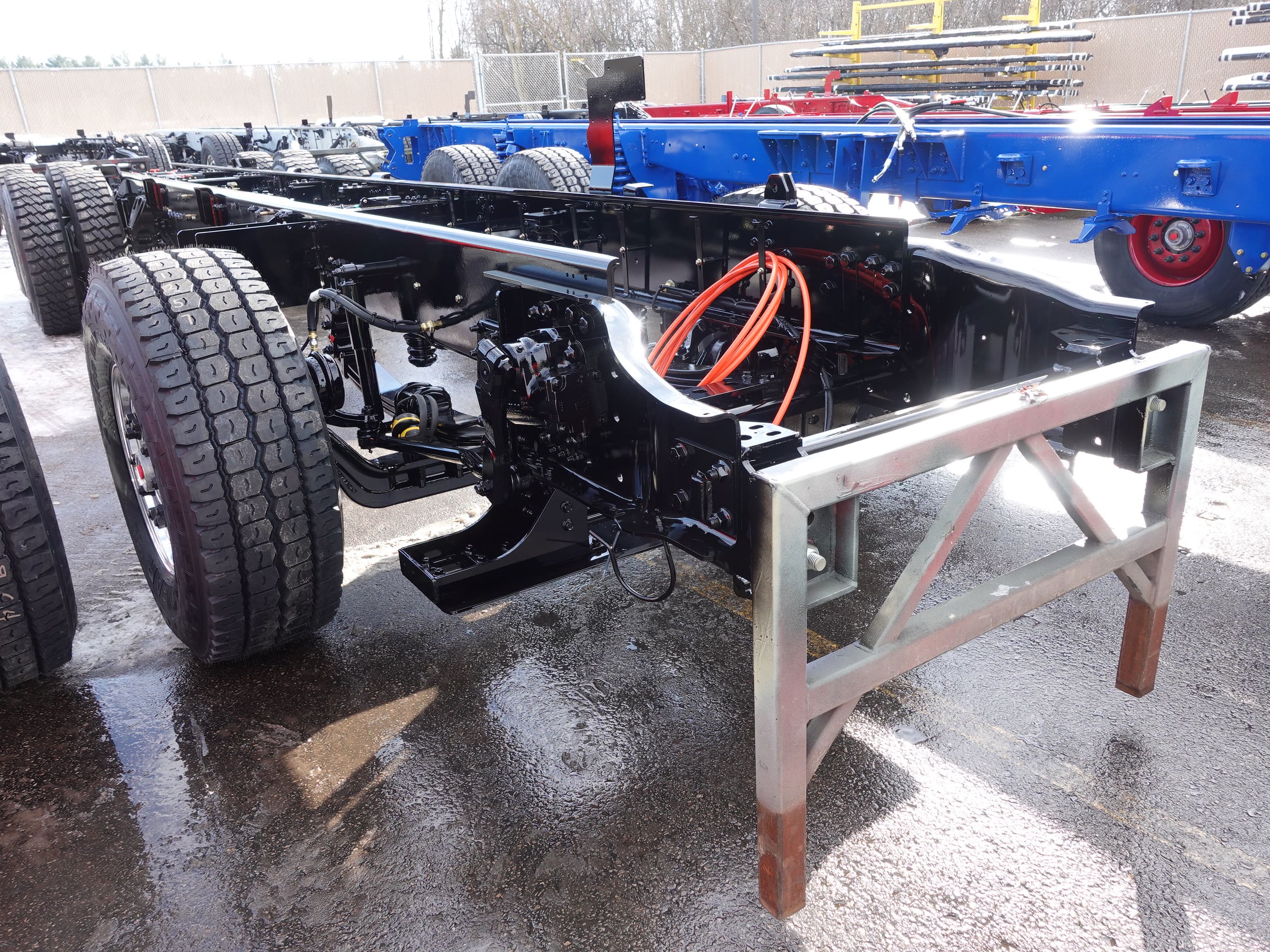

01-23-26

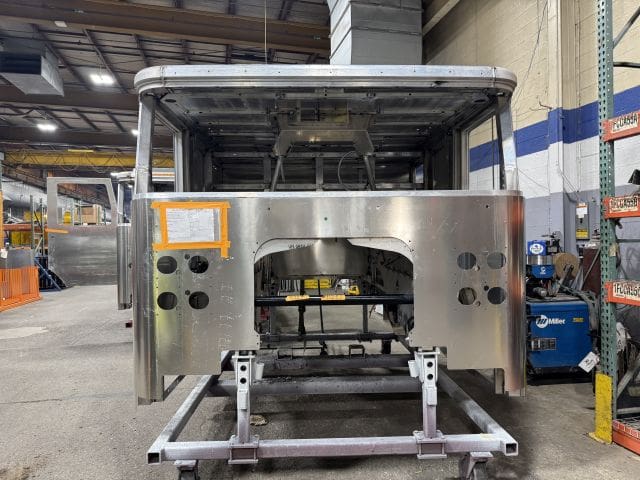

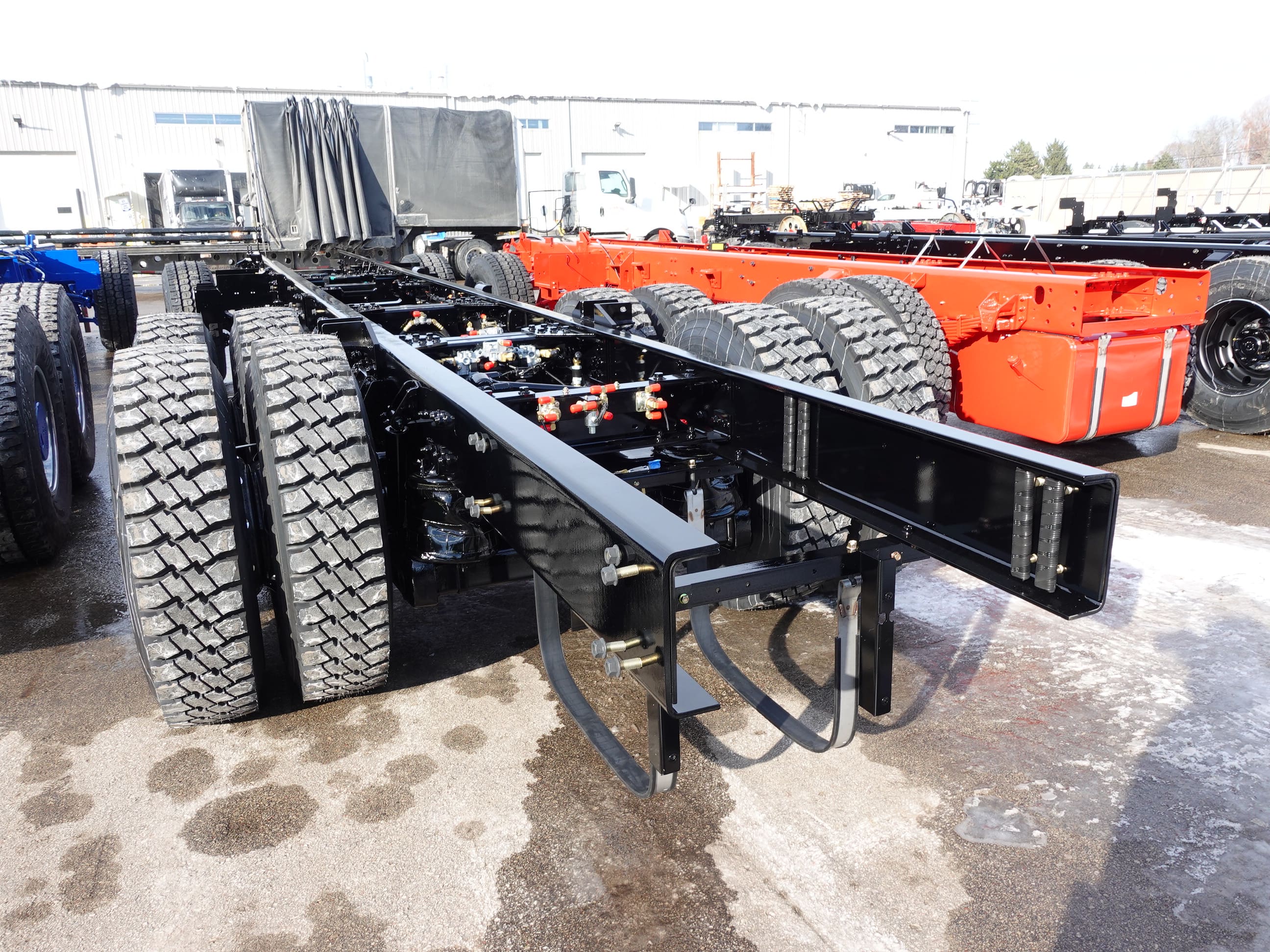

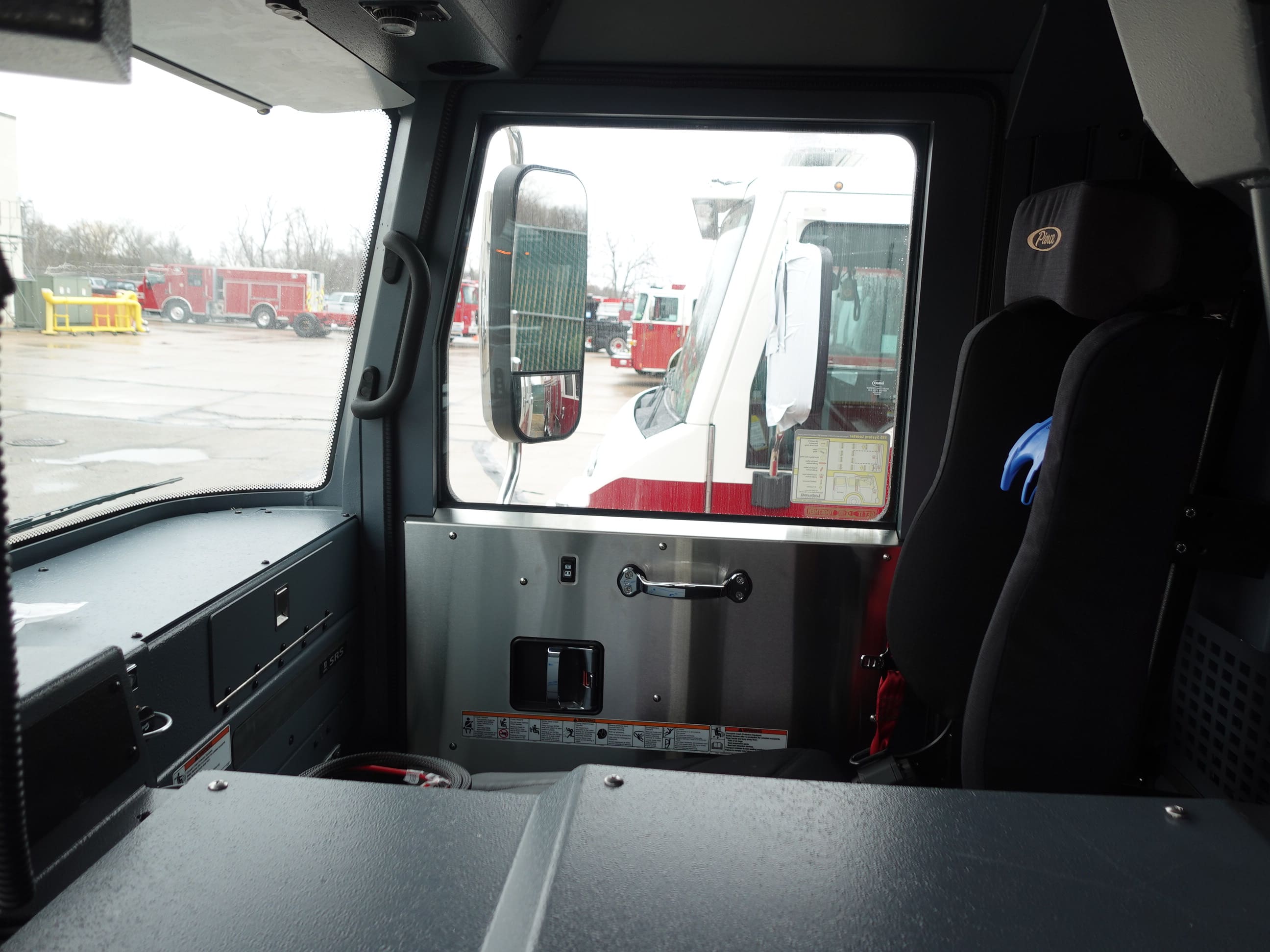

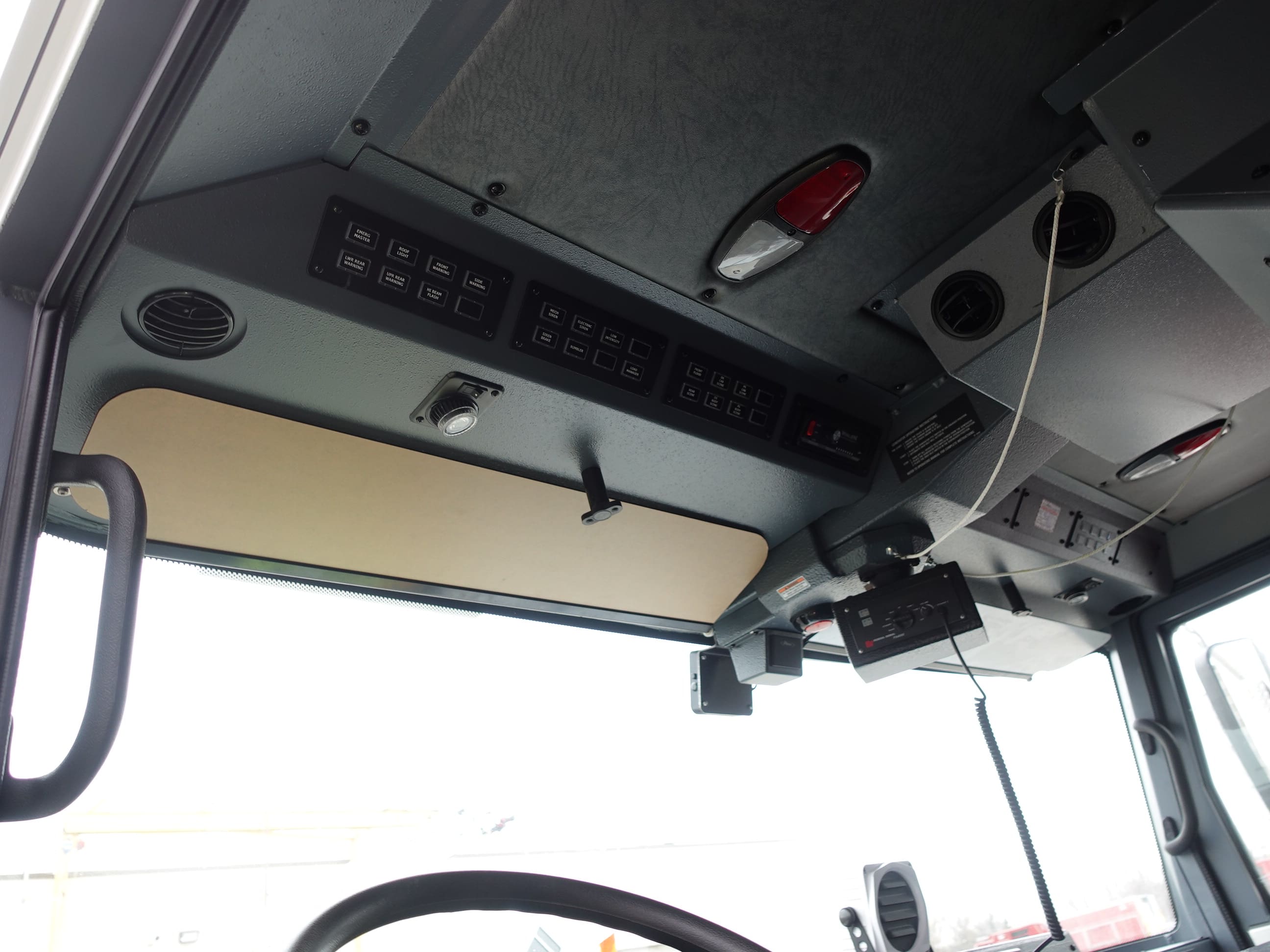

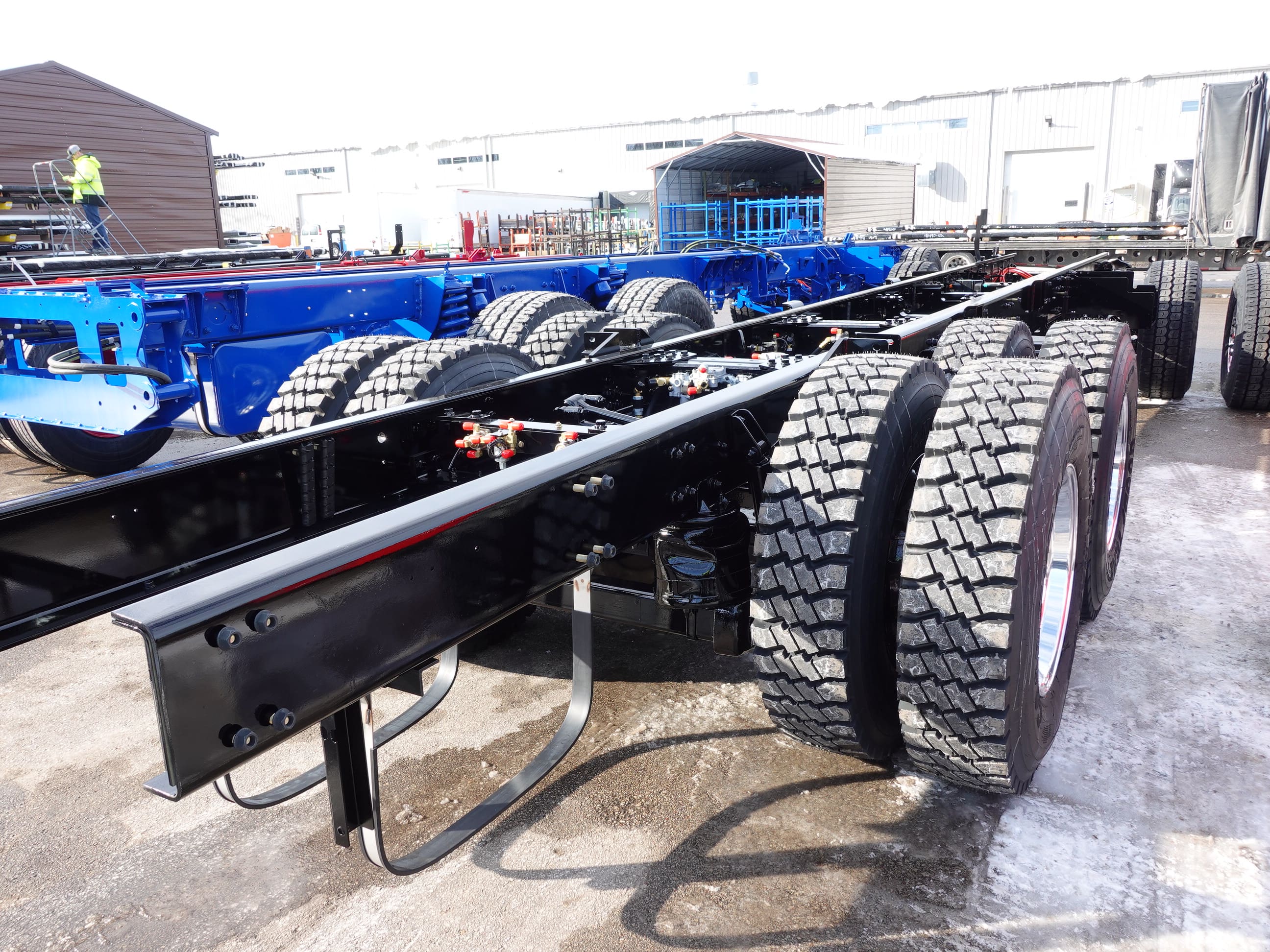

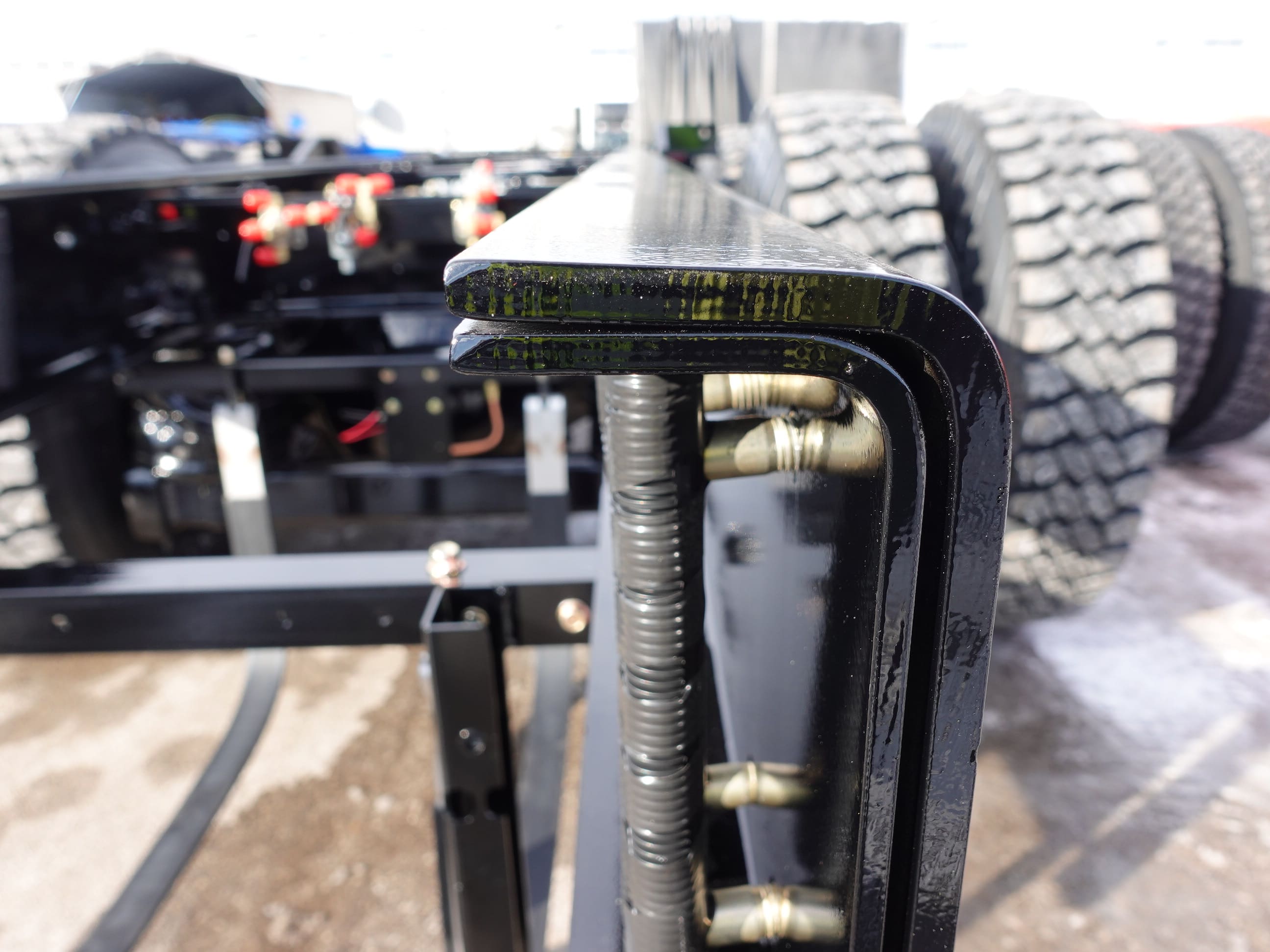

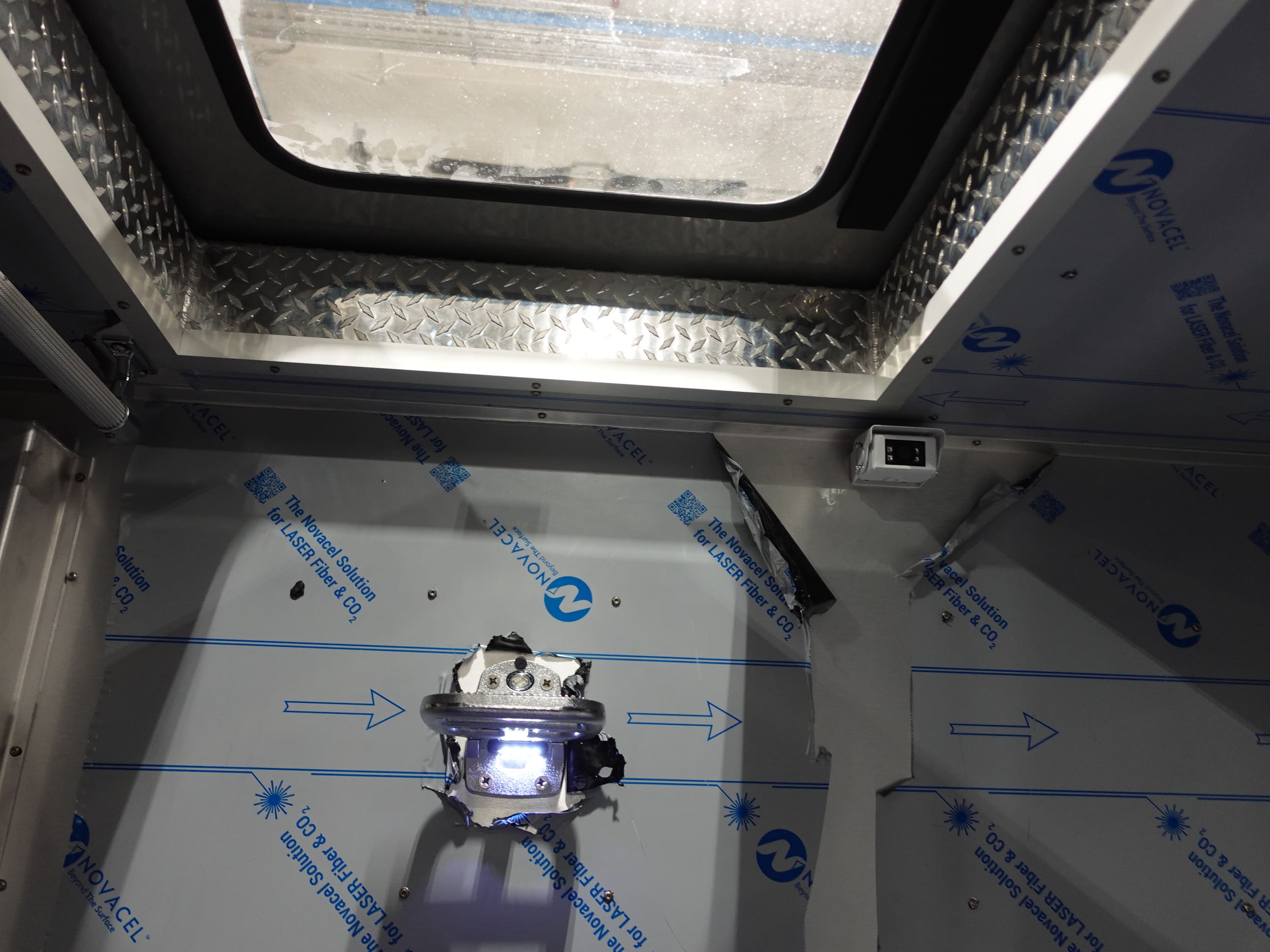

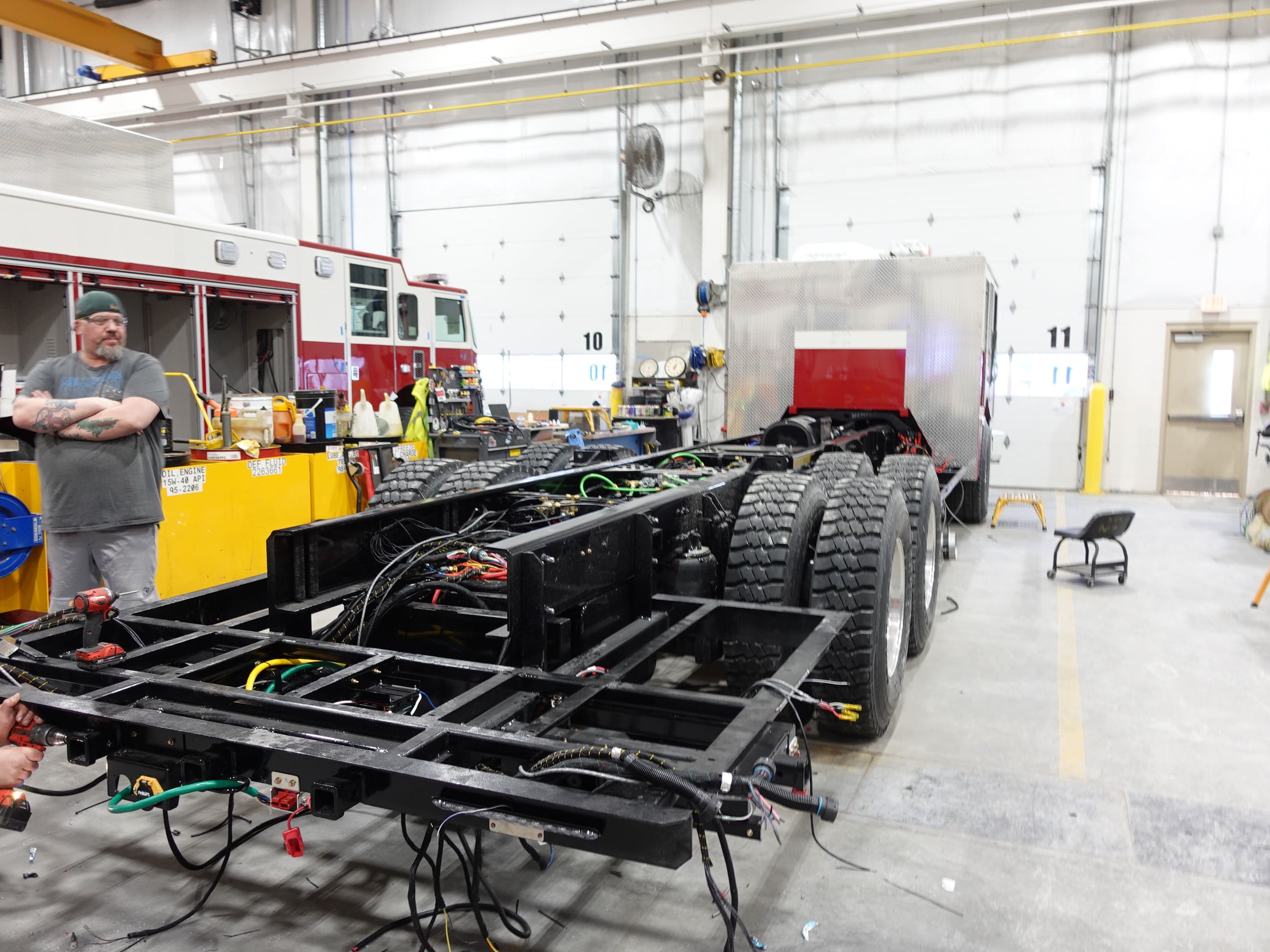

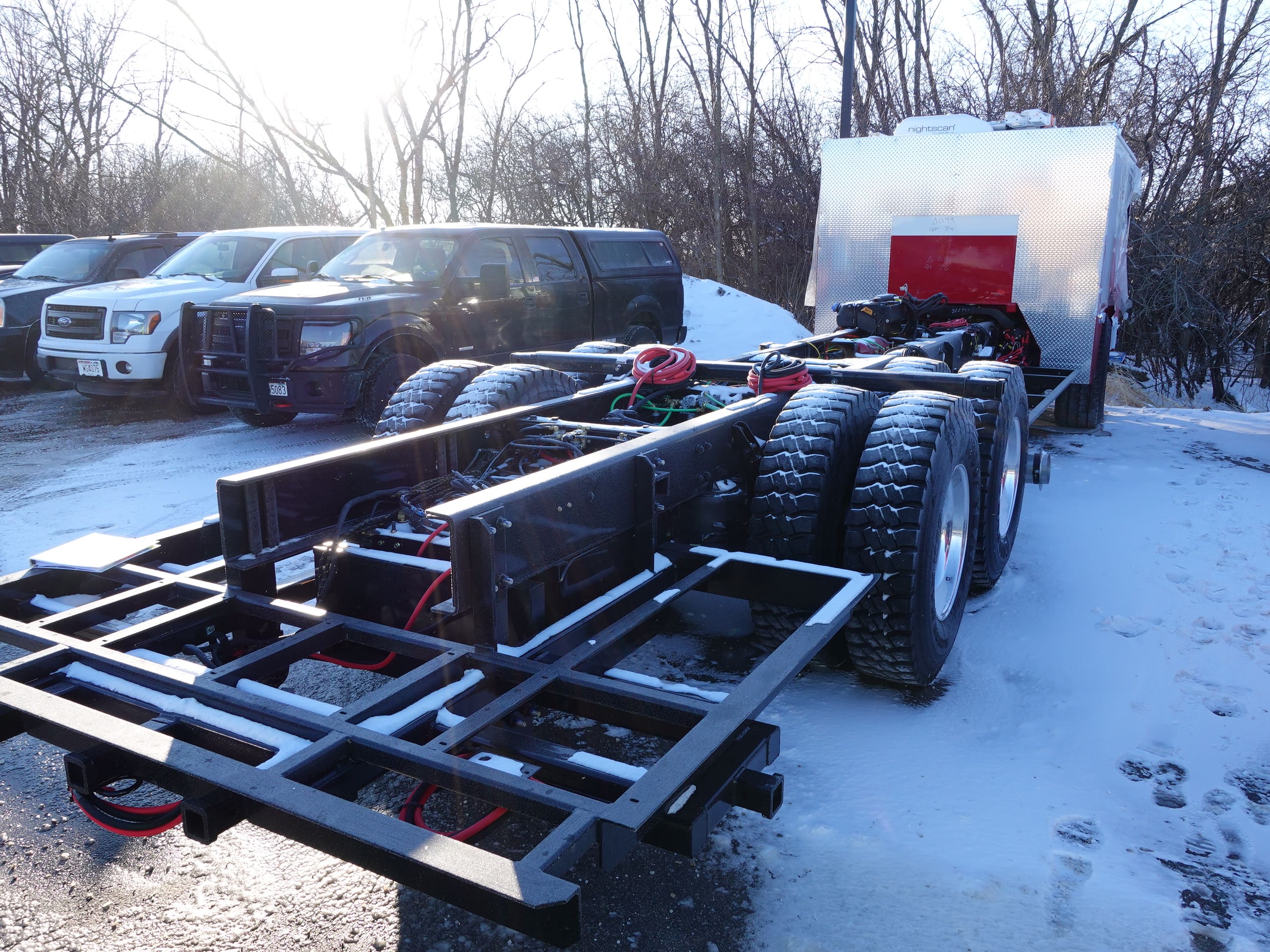

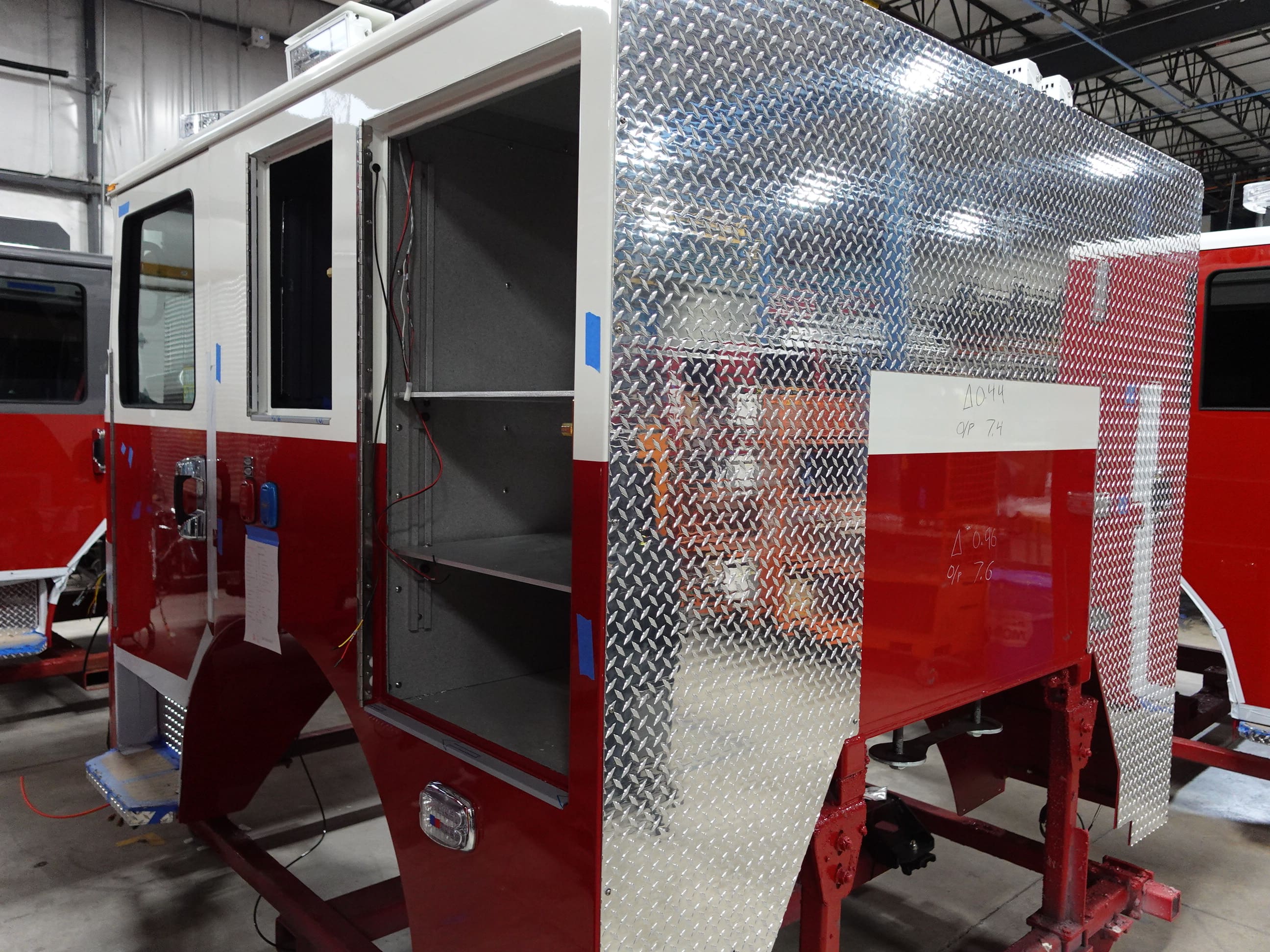

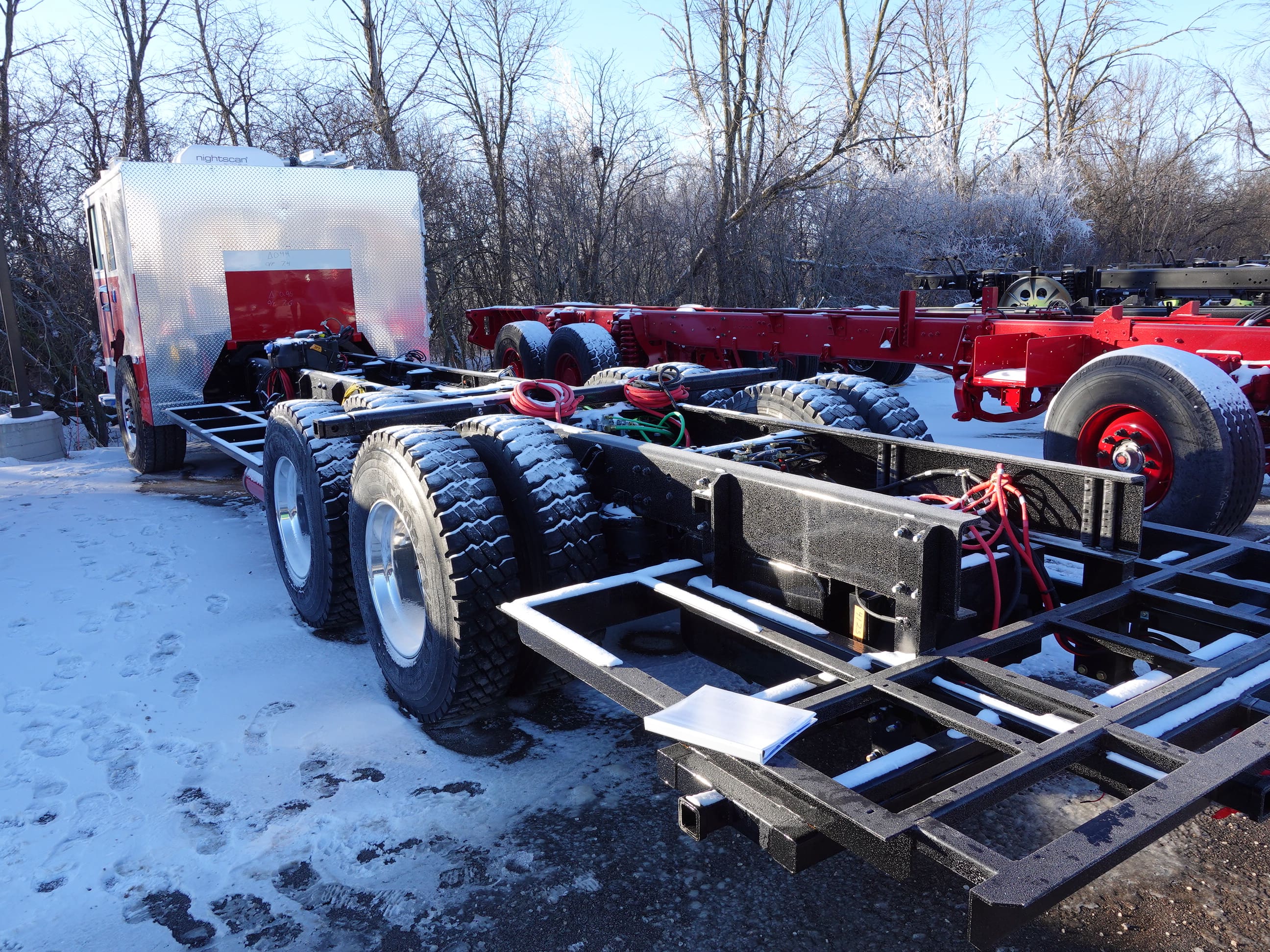

In this report, the cab was merged with the frame then the chassis was staged to continue assembly while the body began initial assembly.

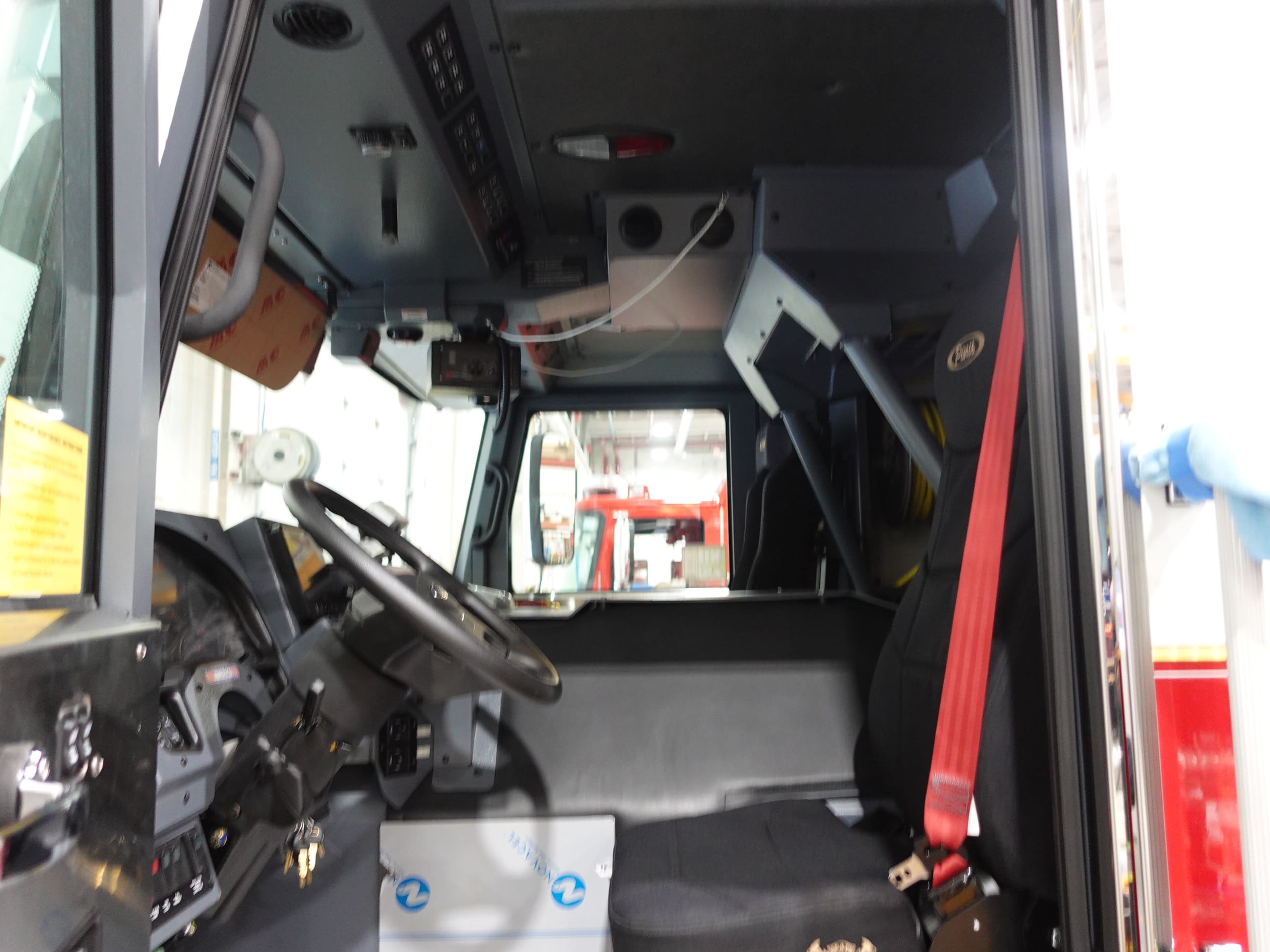

01-16-26

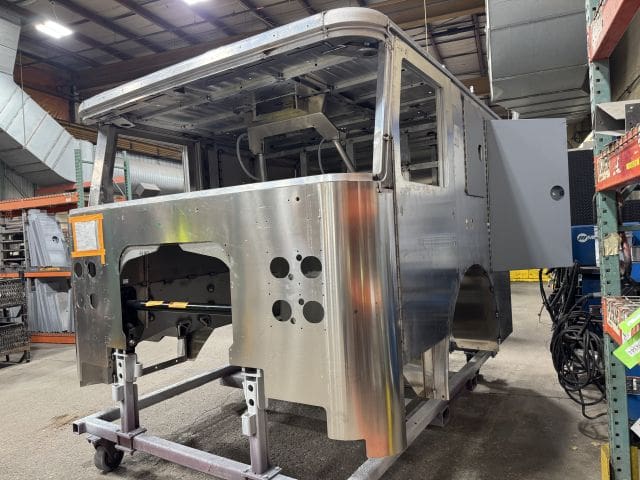

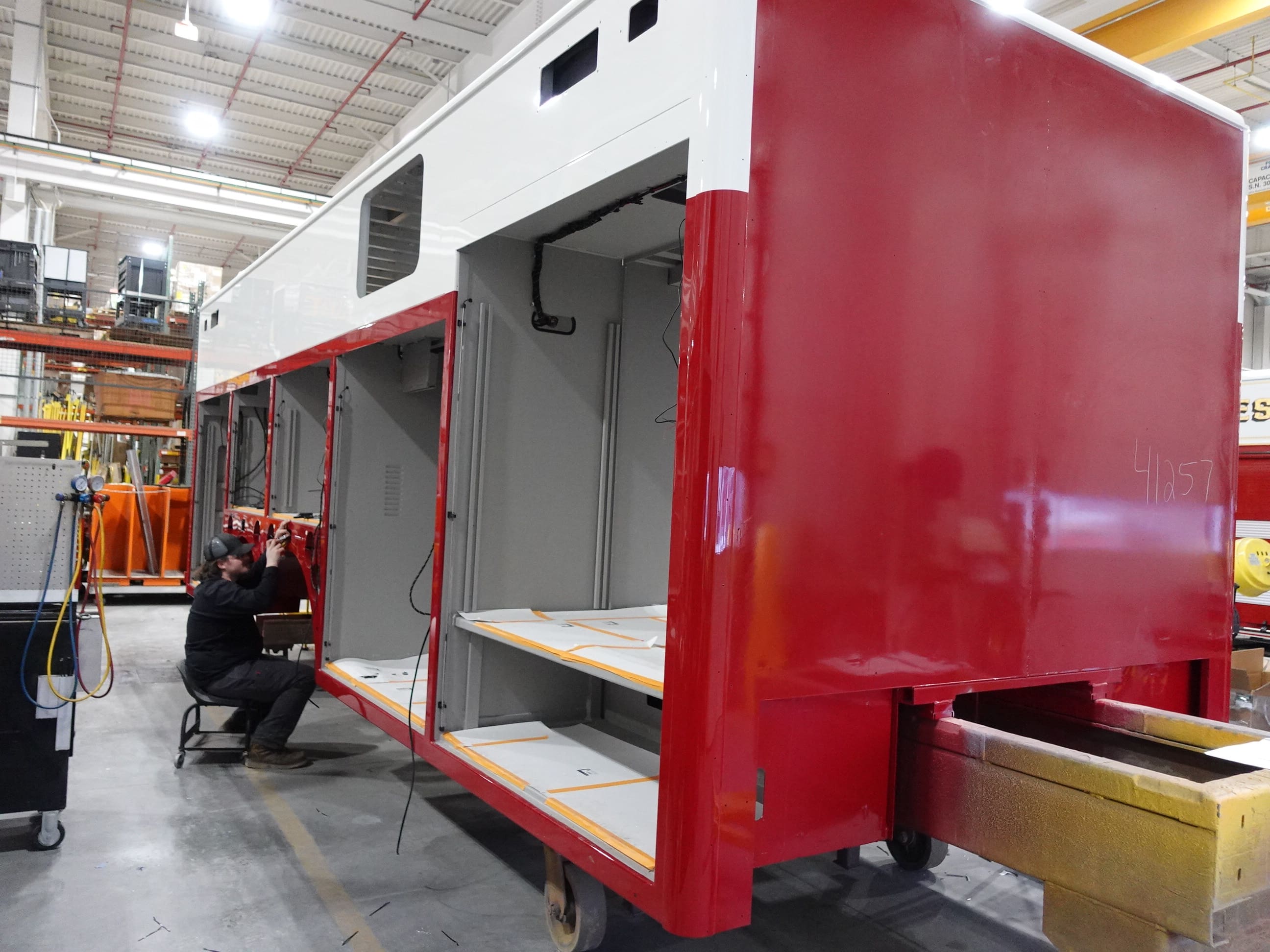

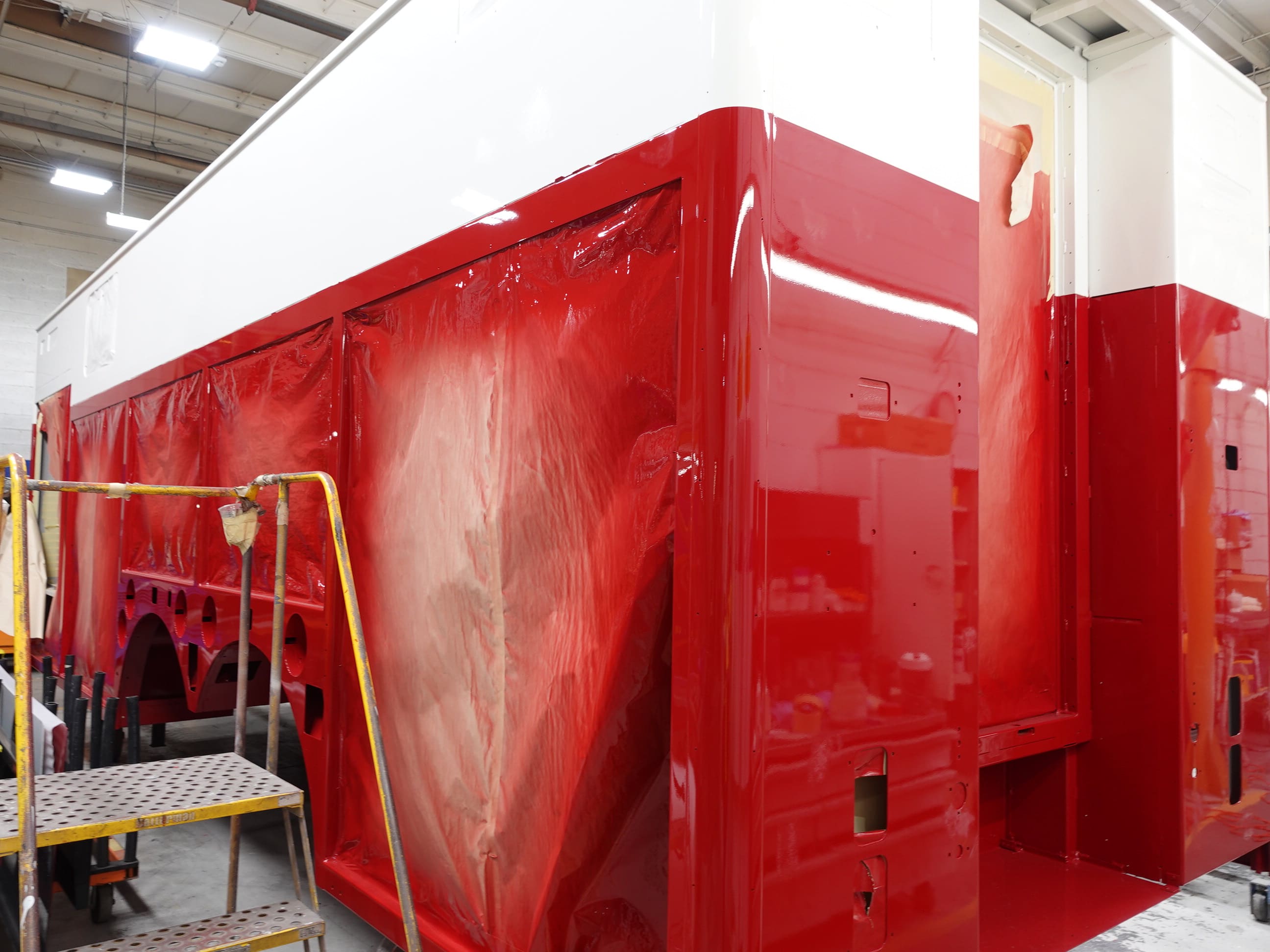

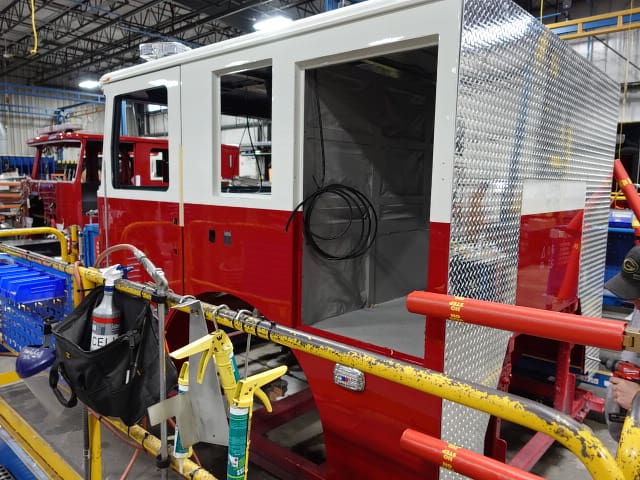

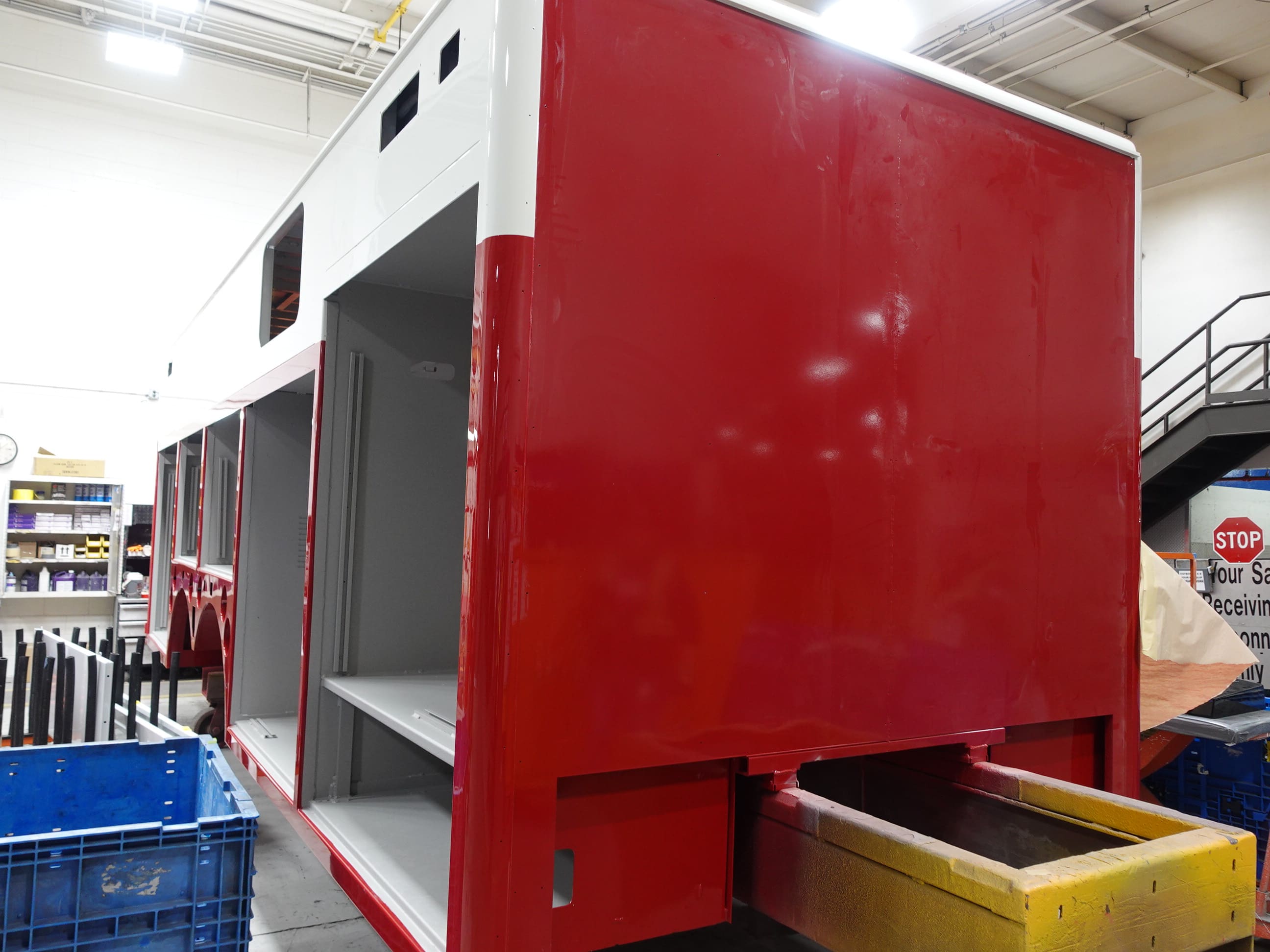

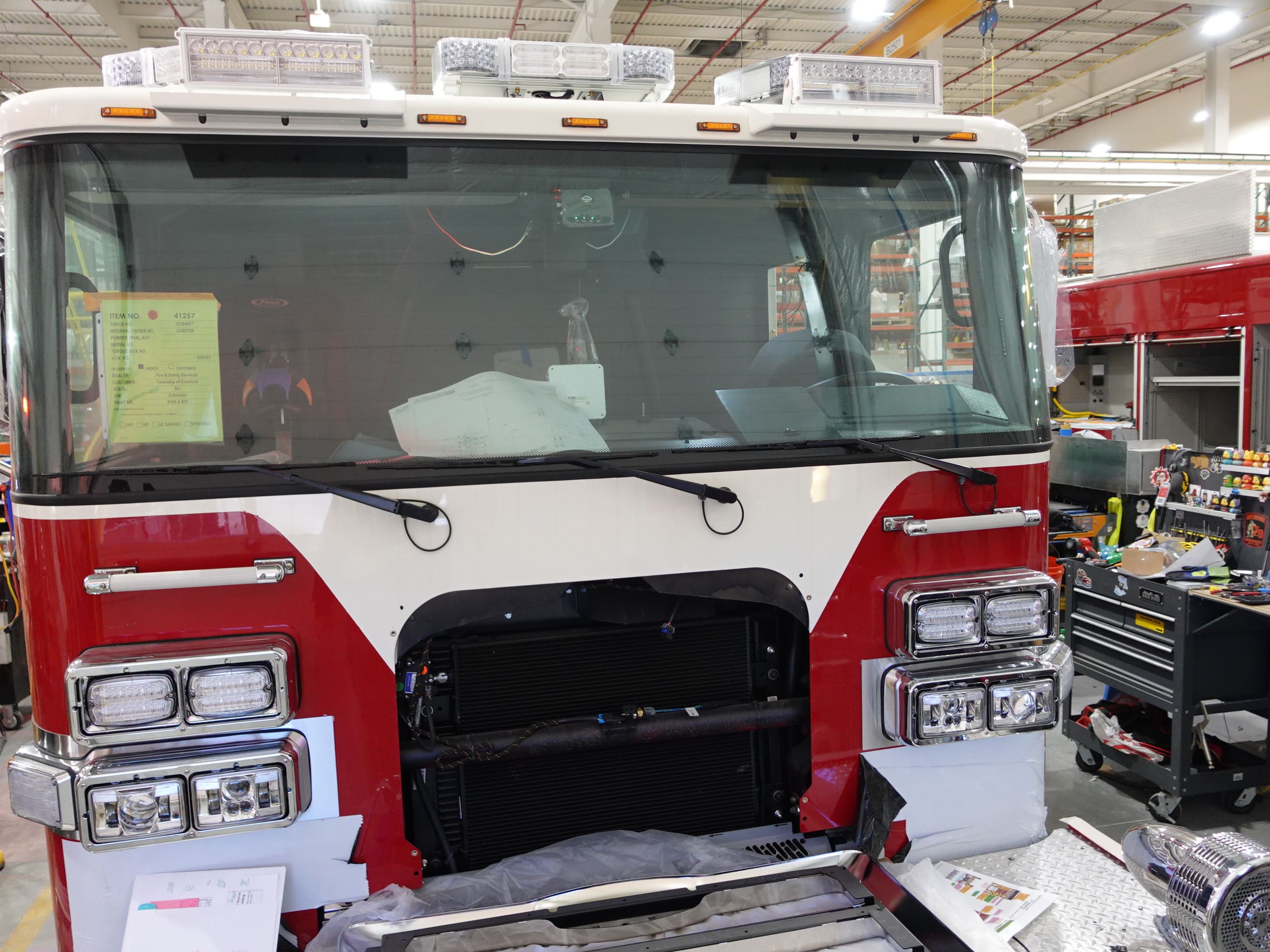

In this report, the cab and frame were unavailable for photos while the body completed paint.
01-09-26

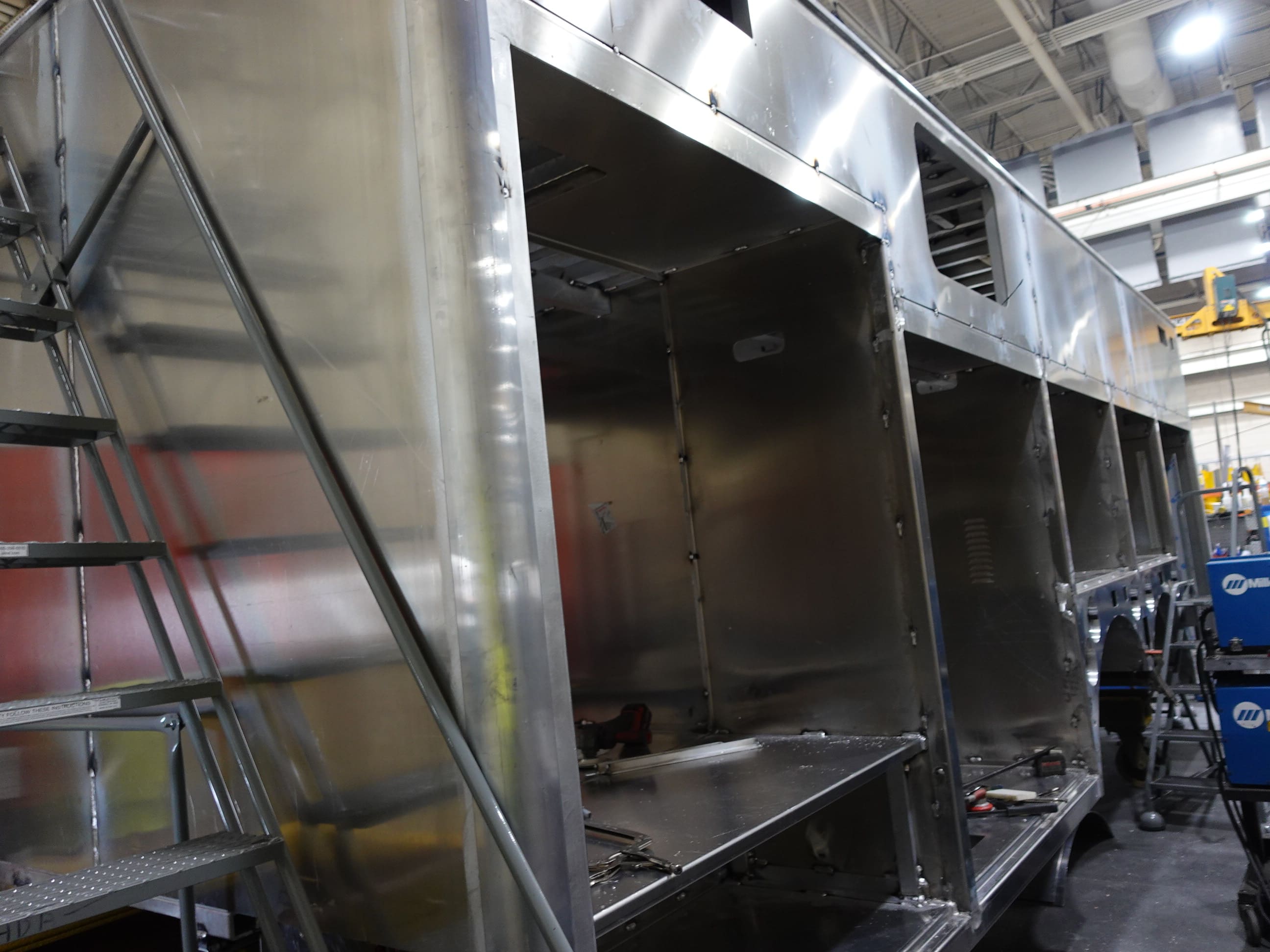

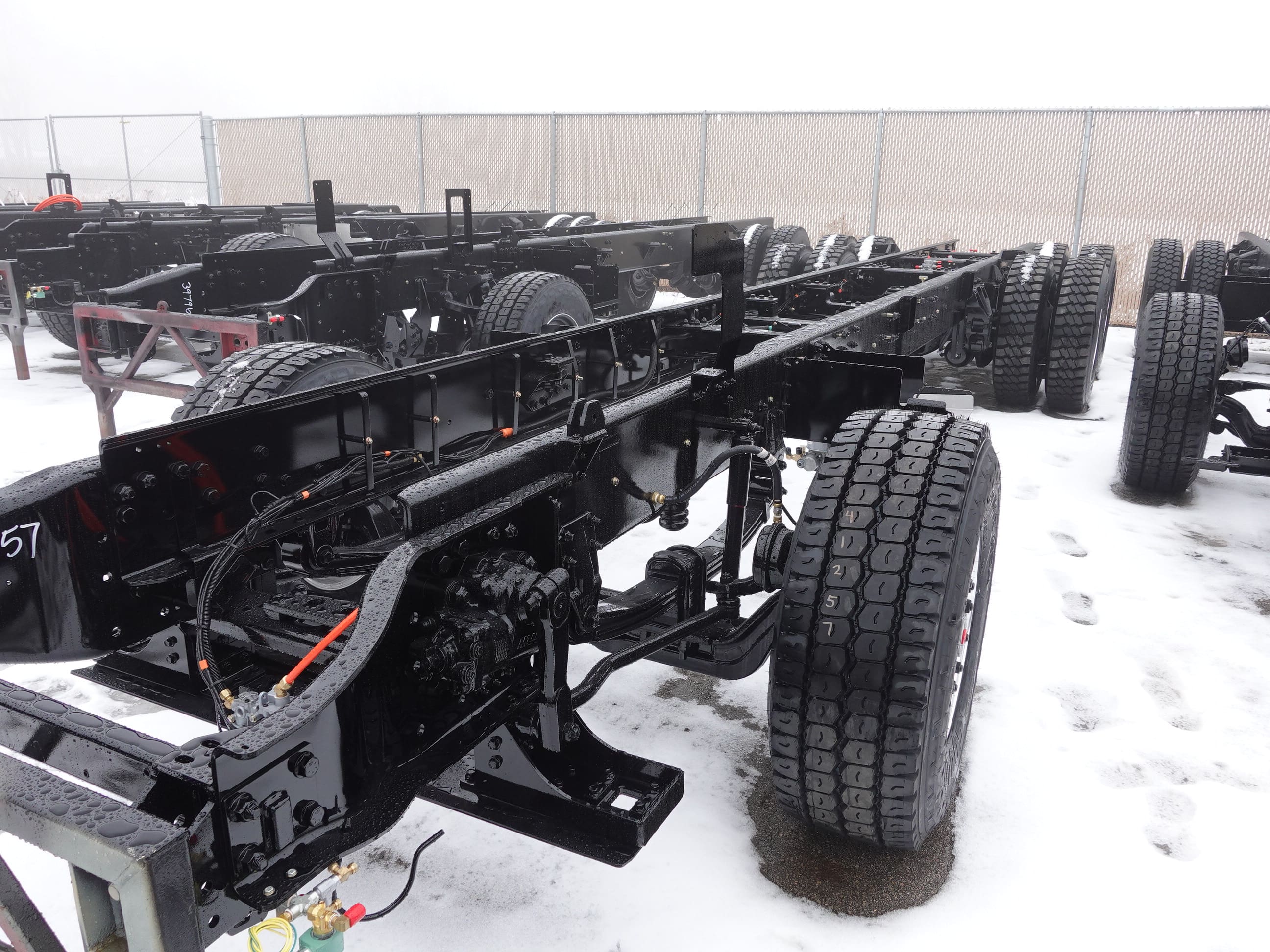

In this report, the cab continued initial assembly, the frame build continued, and the body continued through paint.
12-19-25

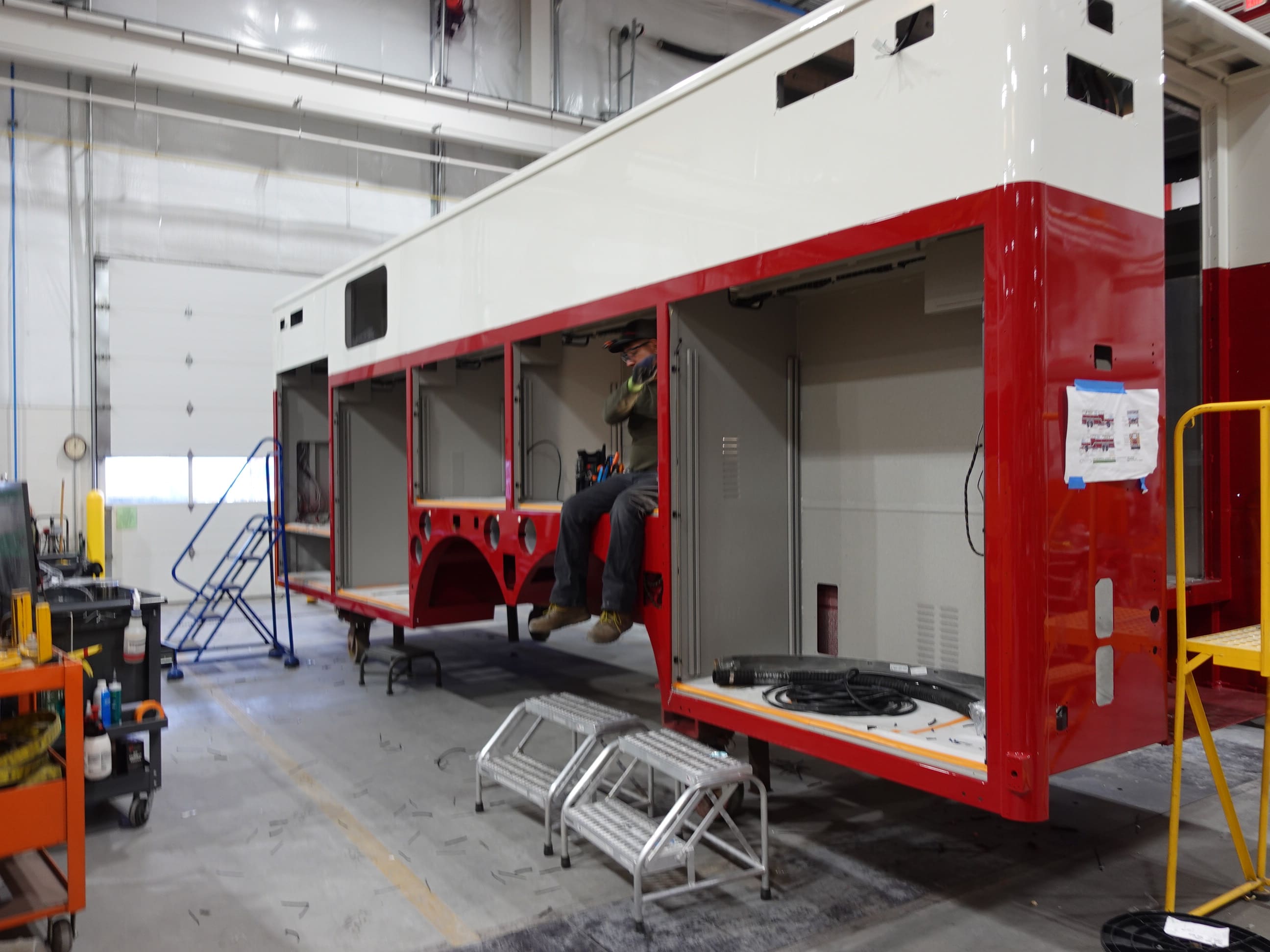

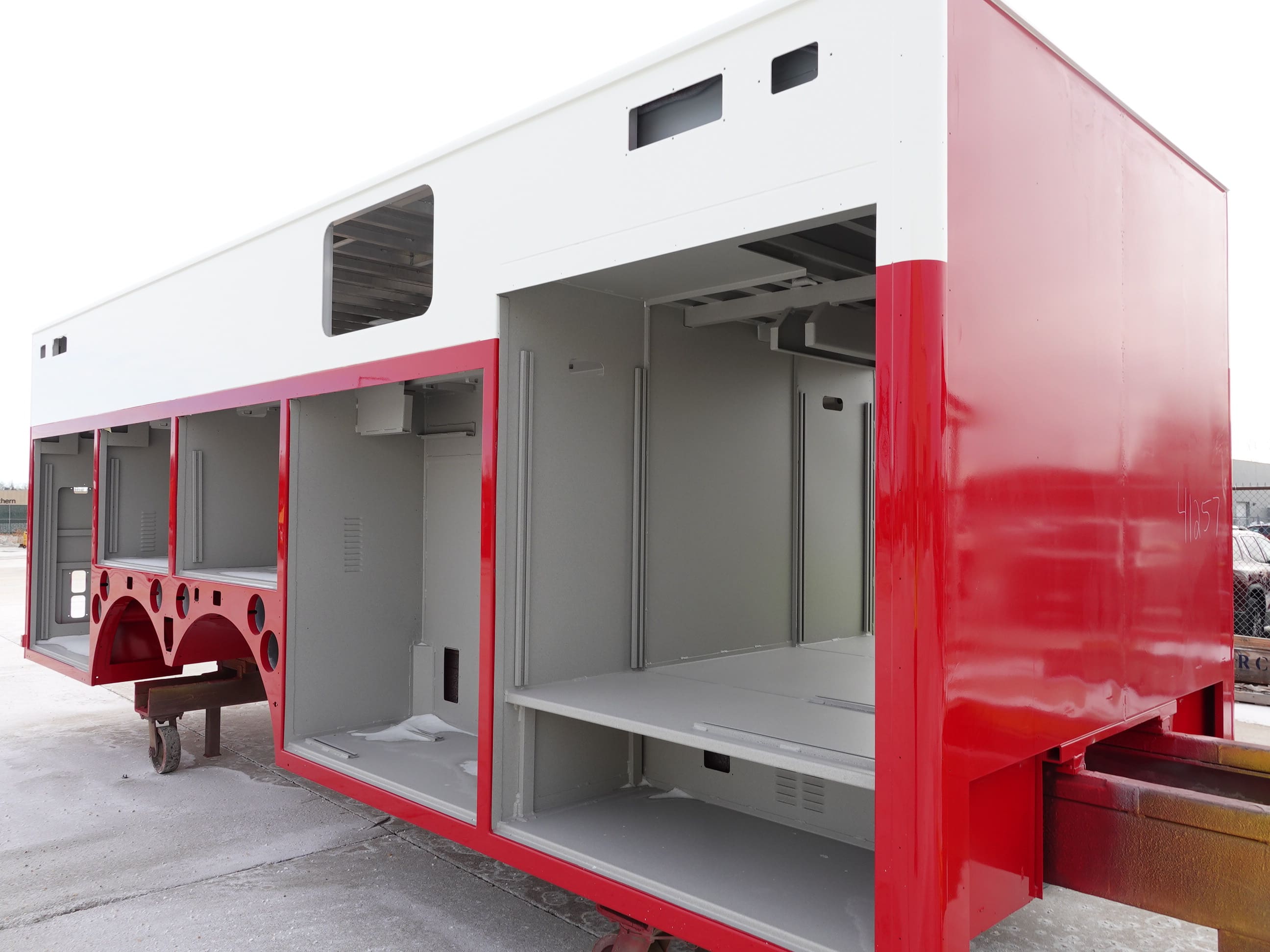

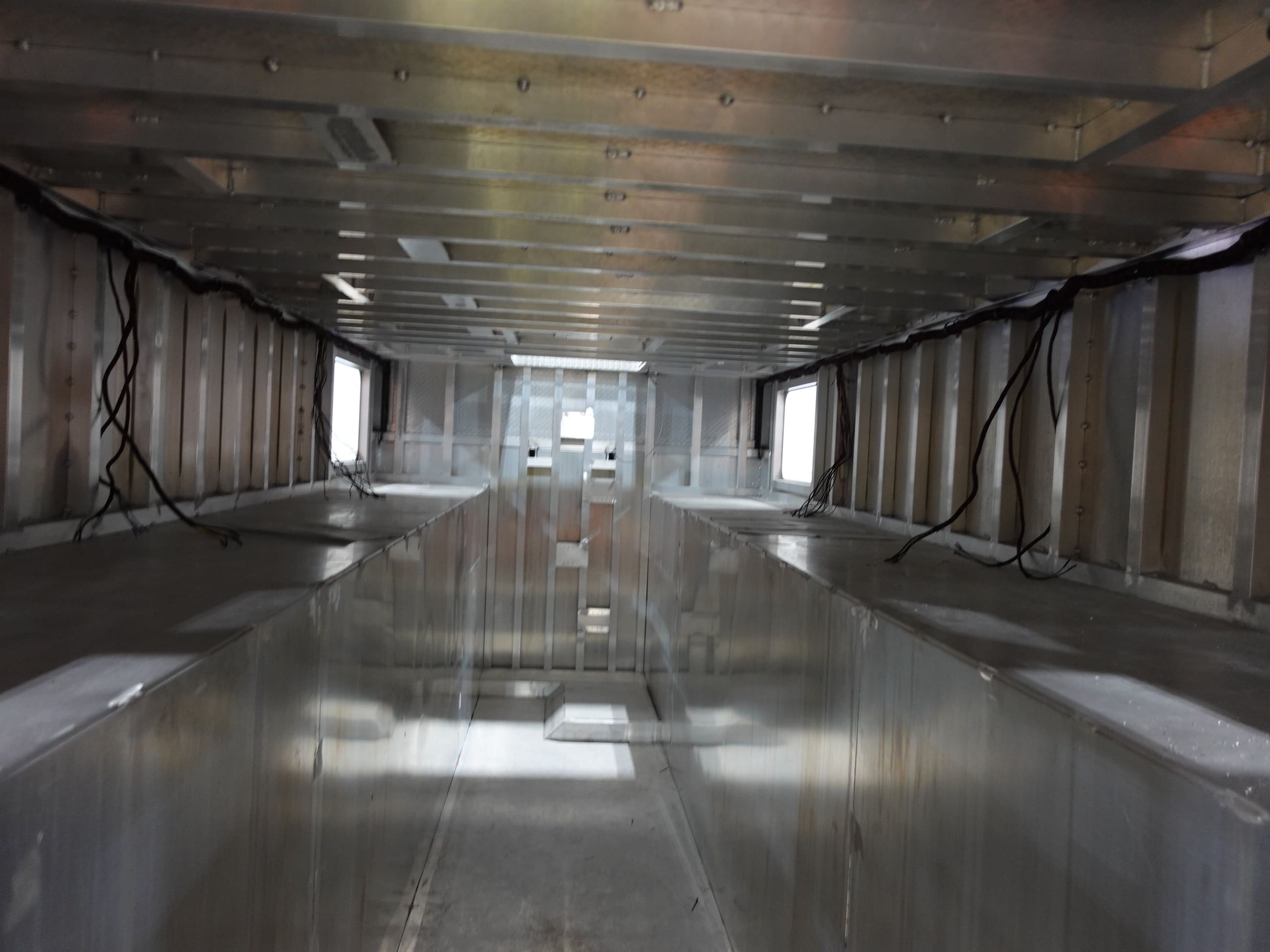

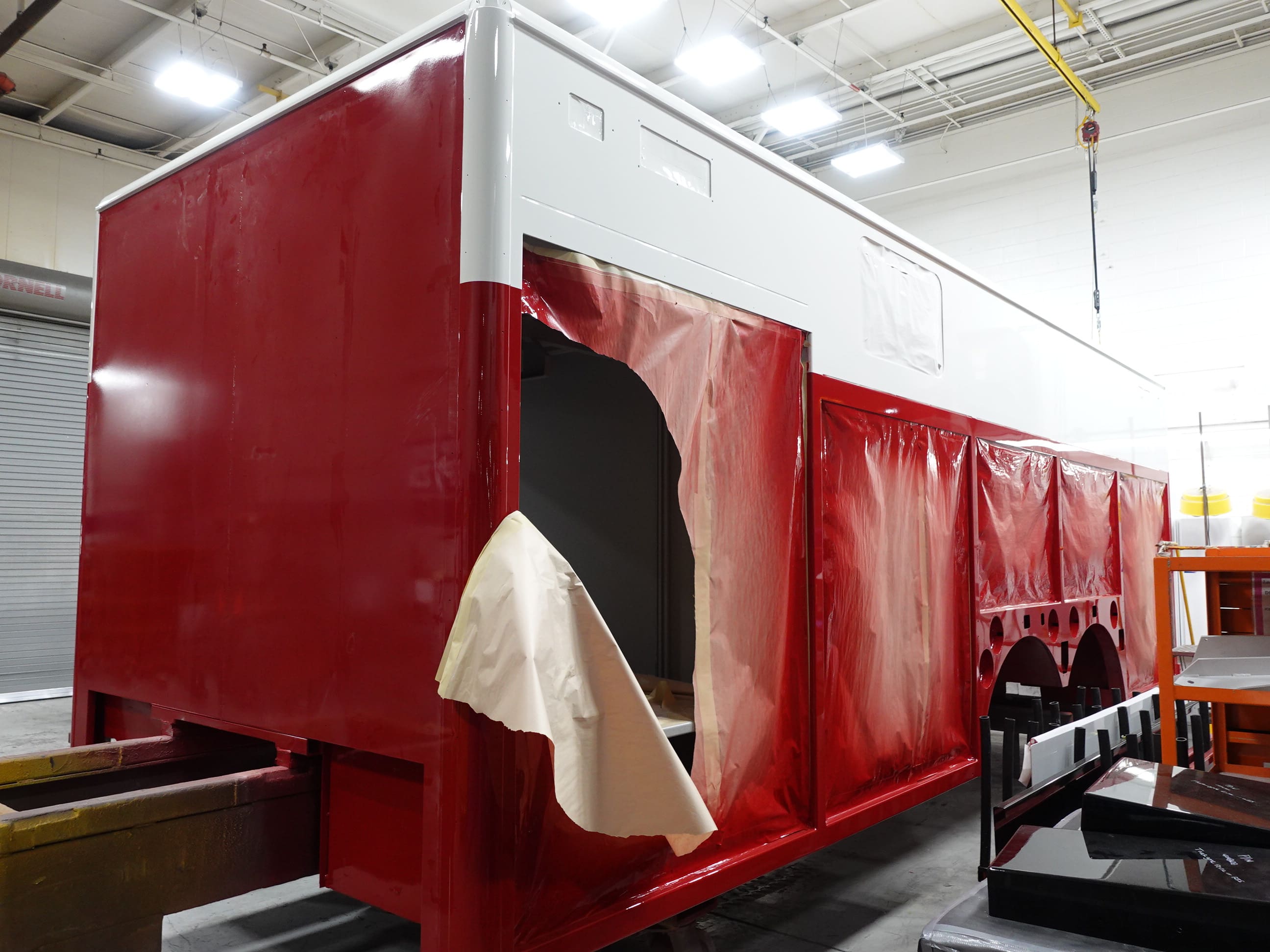

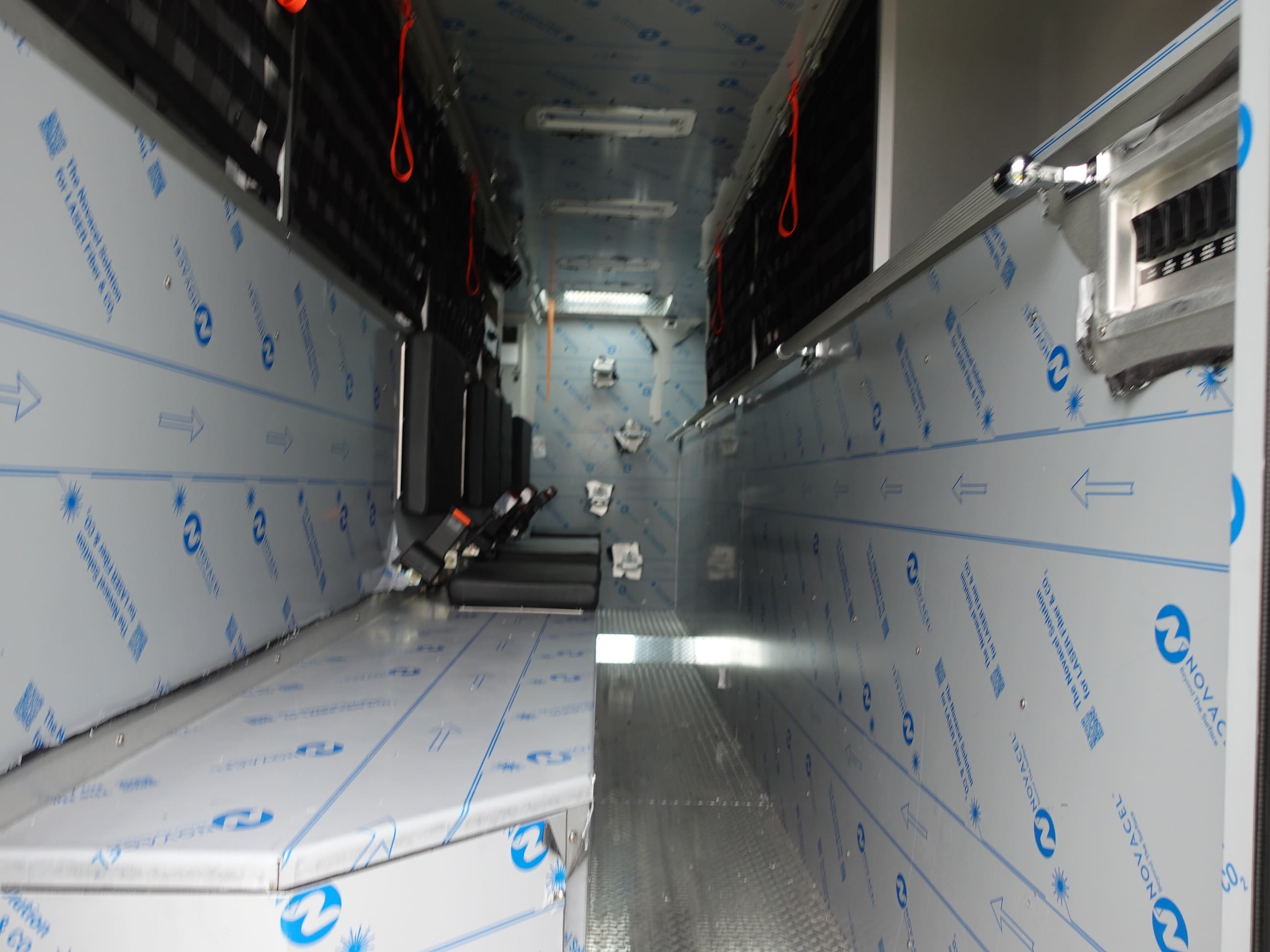

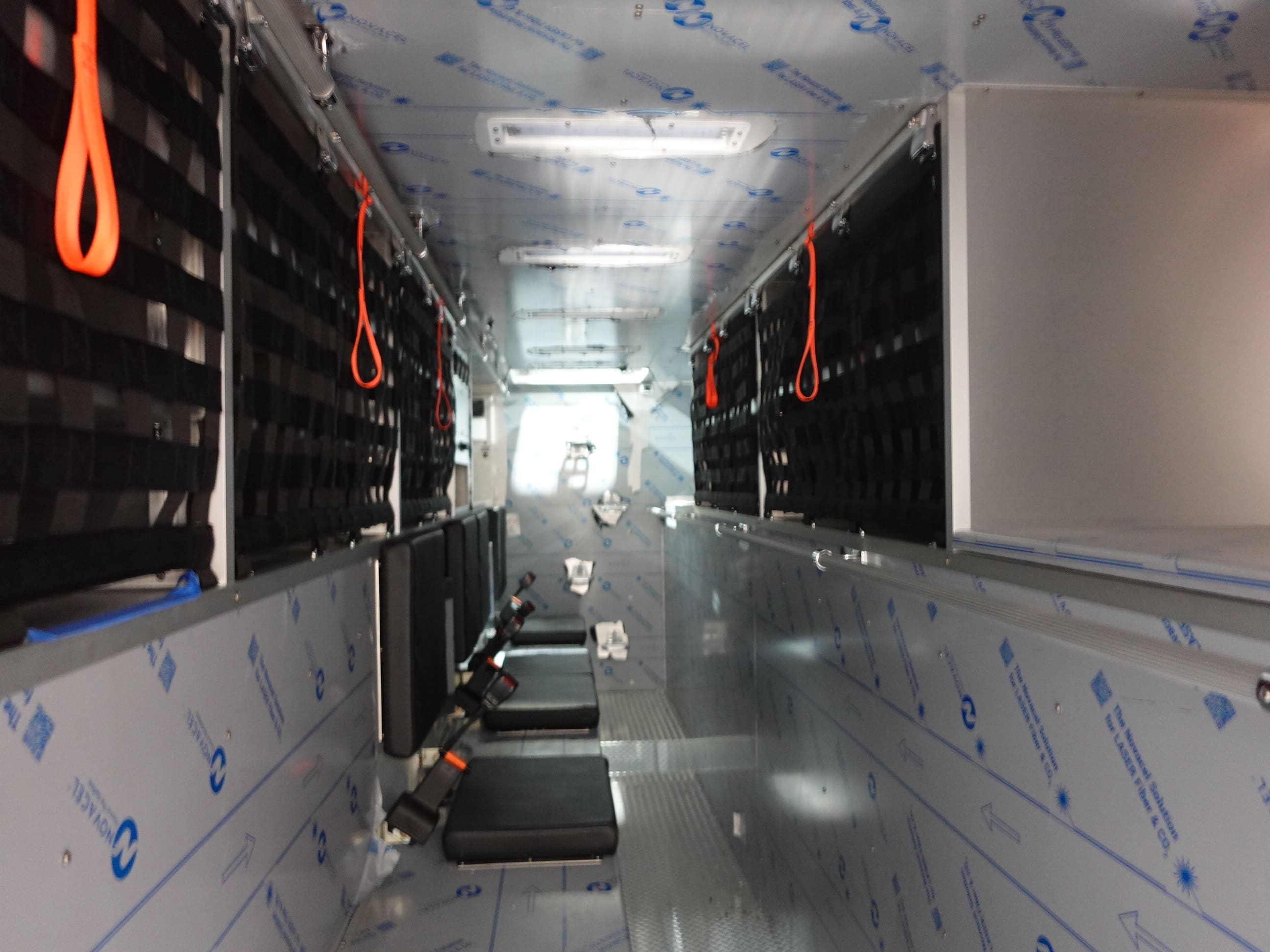

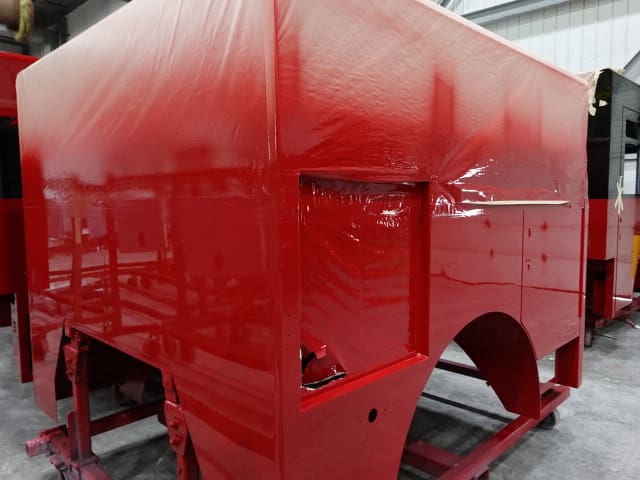

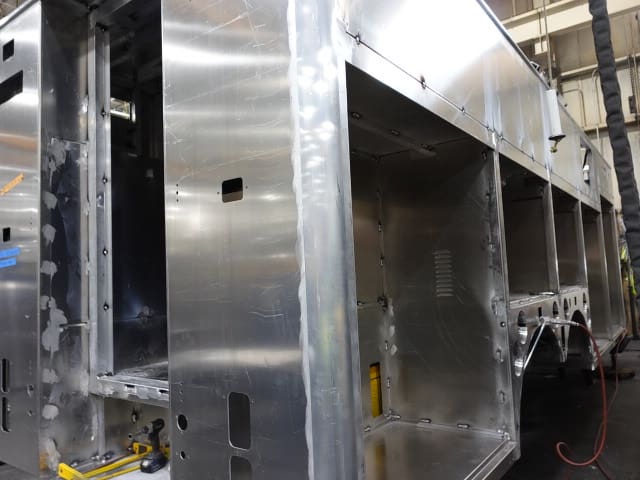

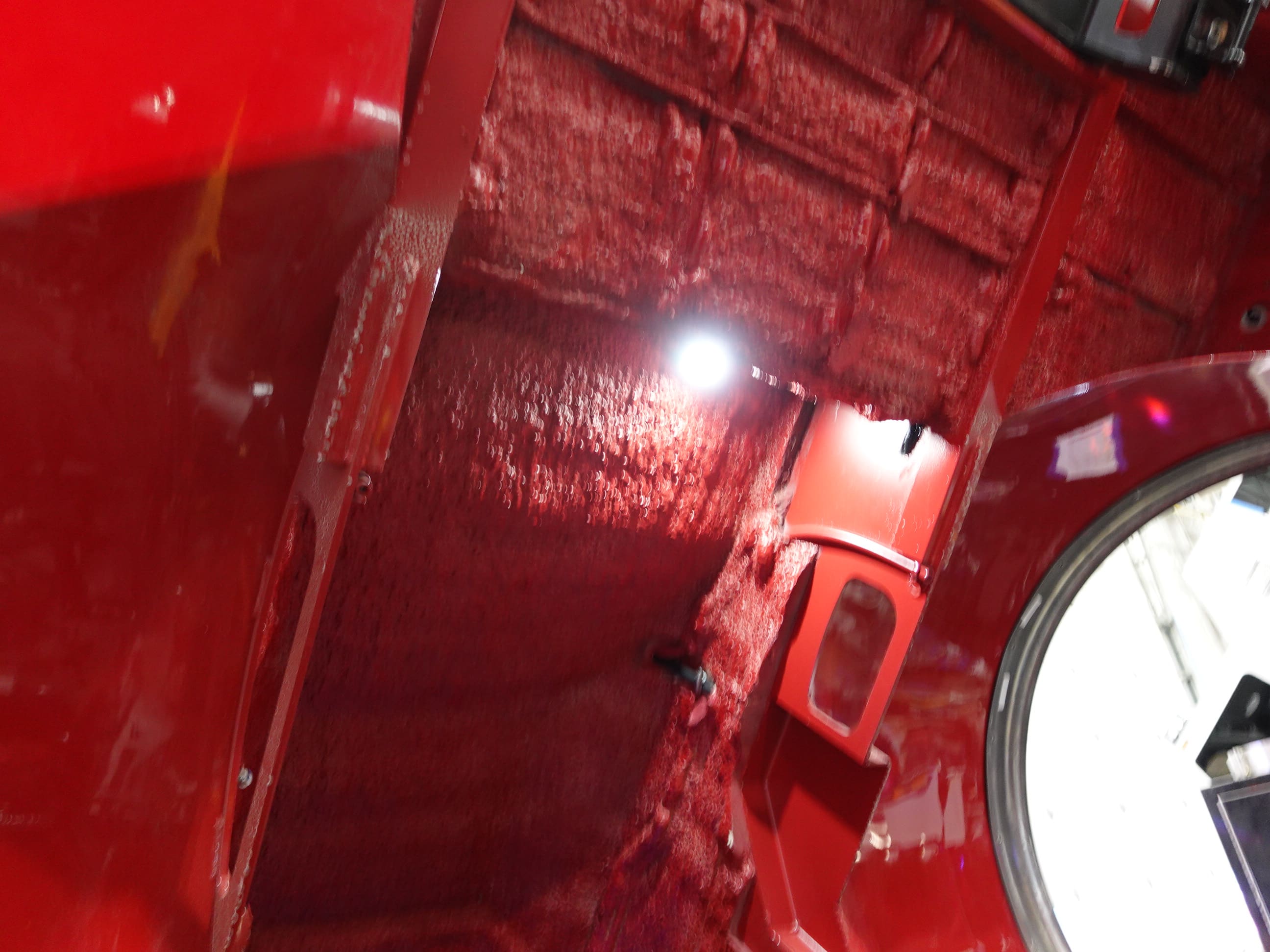

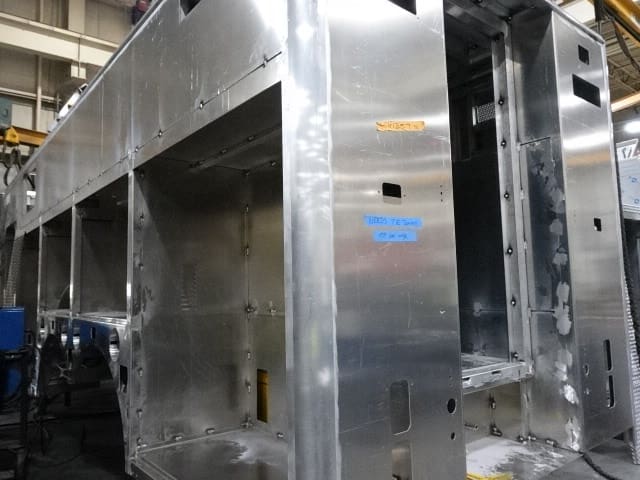

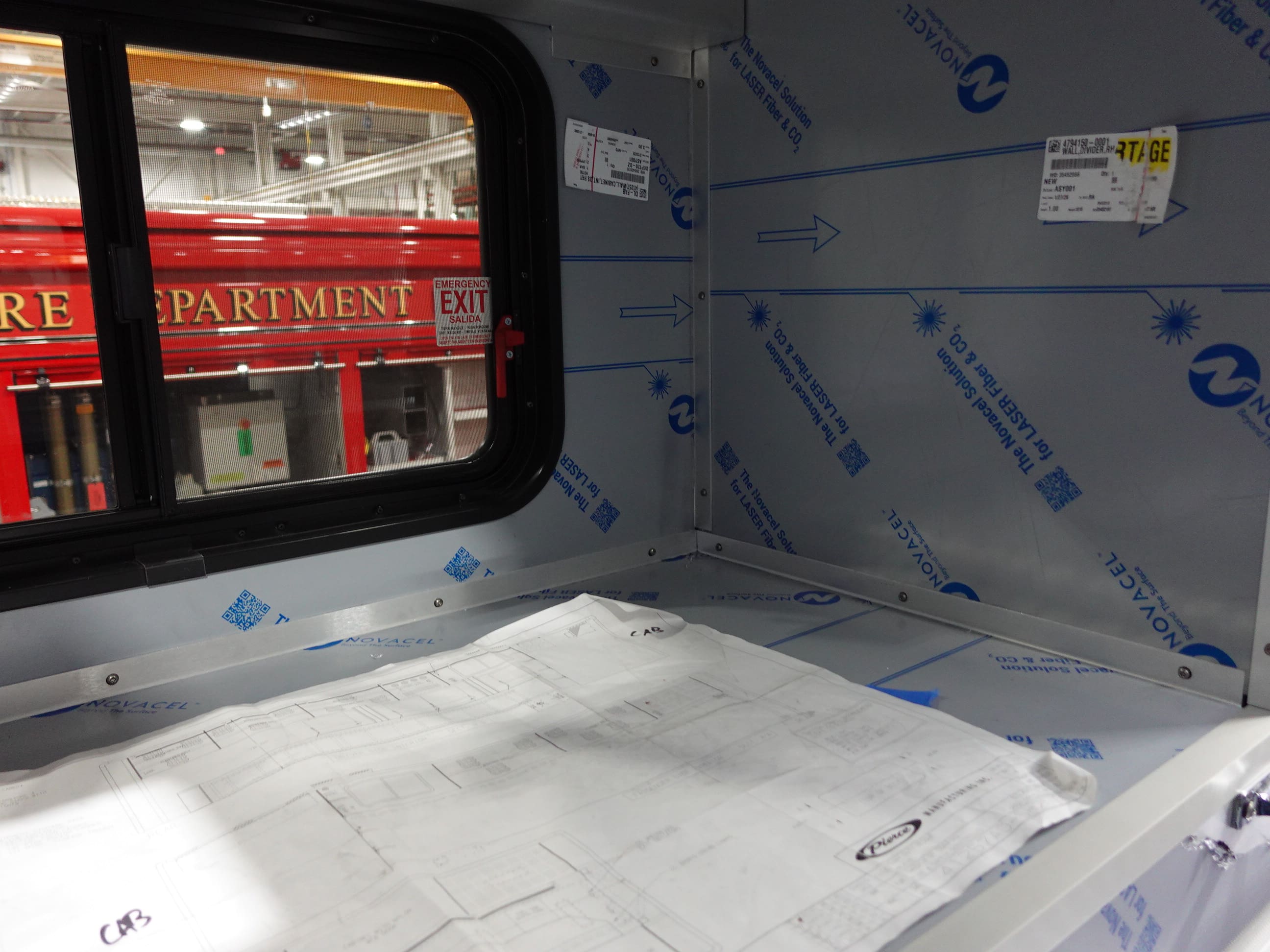

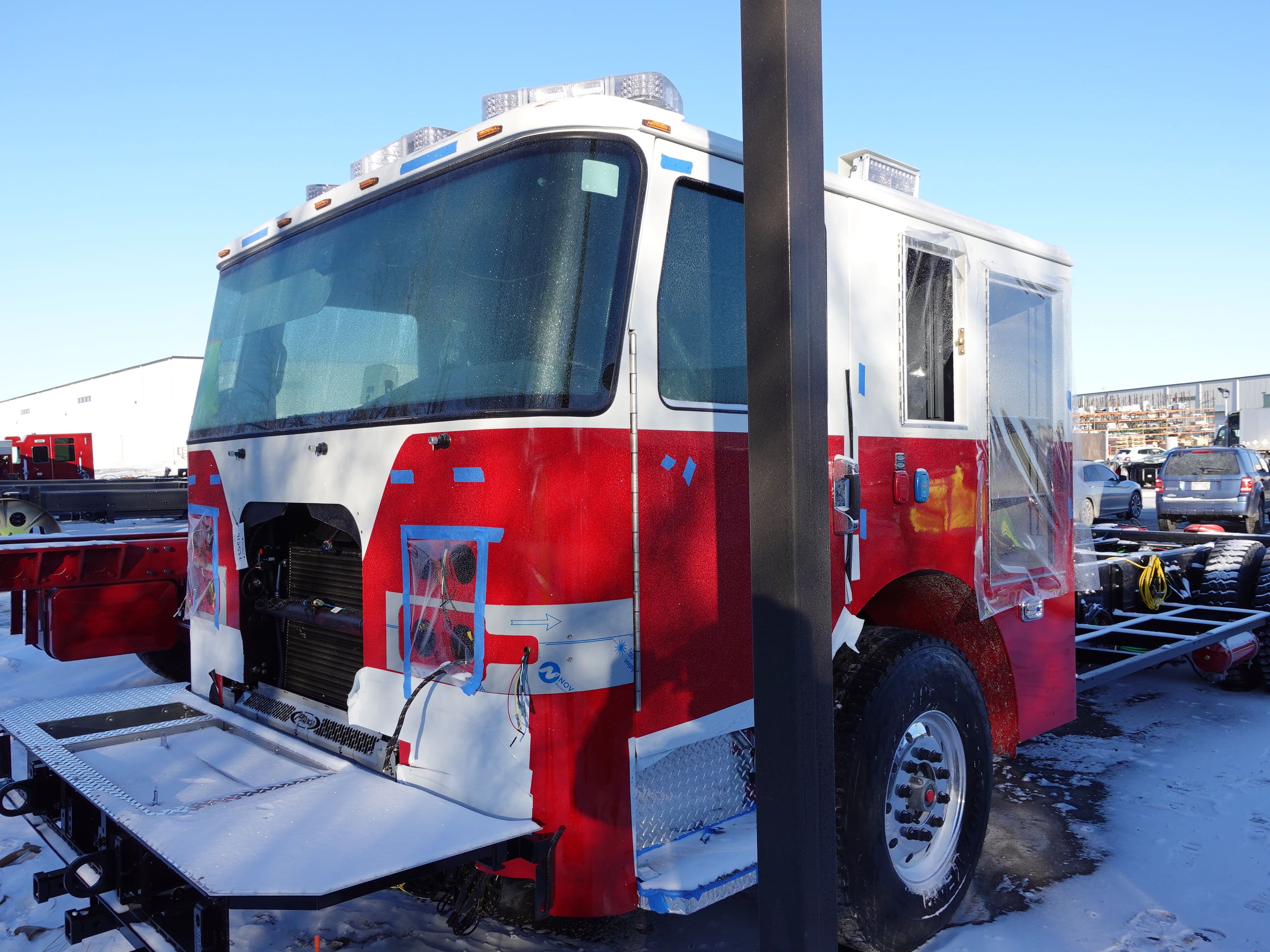

In this report, the cab was staged to continue initial assembly, the frame build began, and the body completed fabrication and began the paint process.

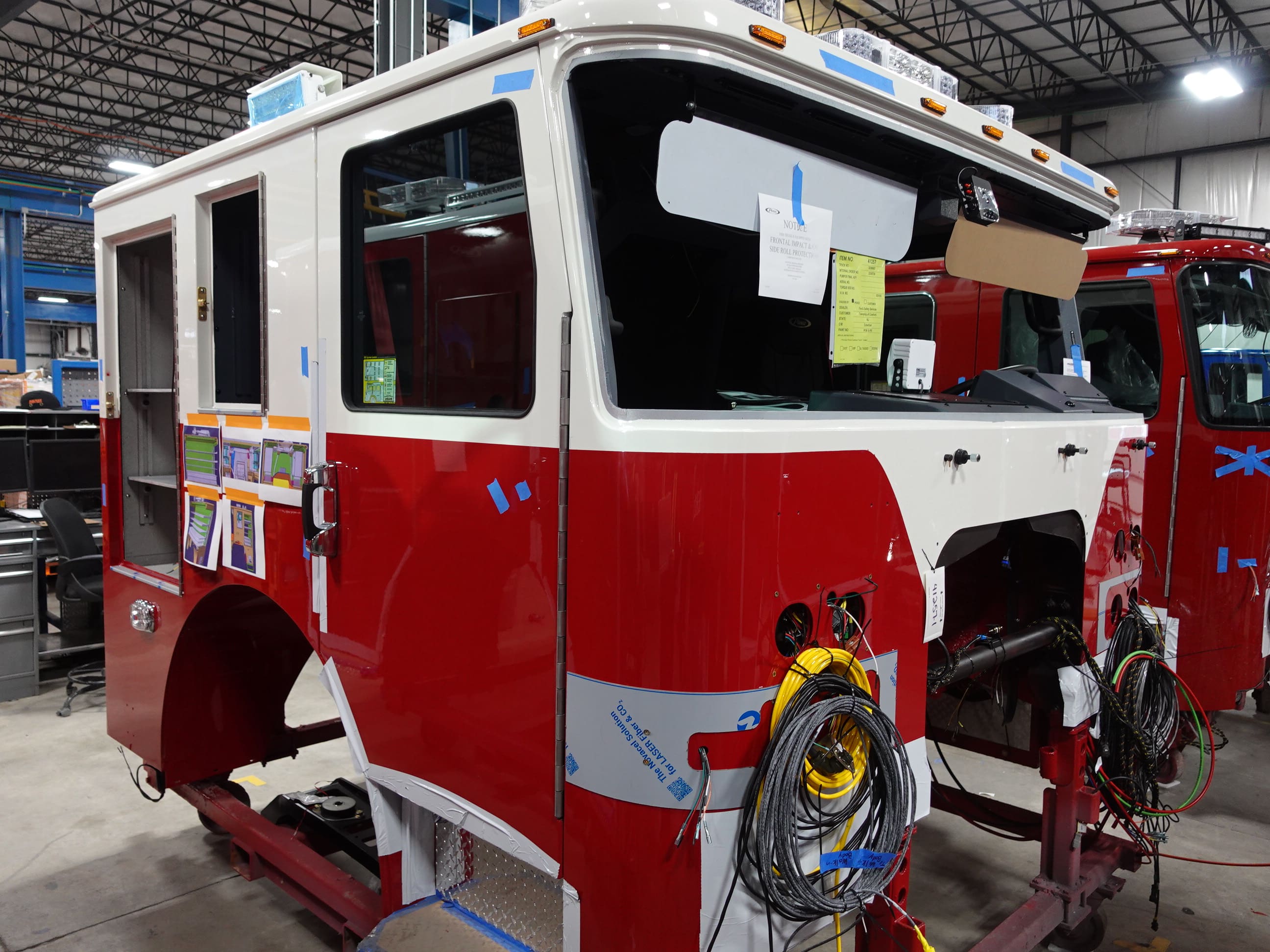

12-12-25

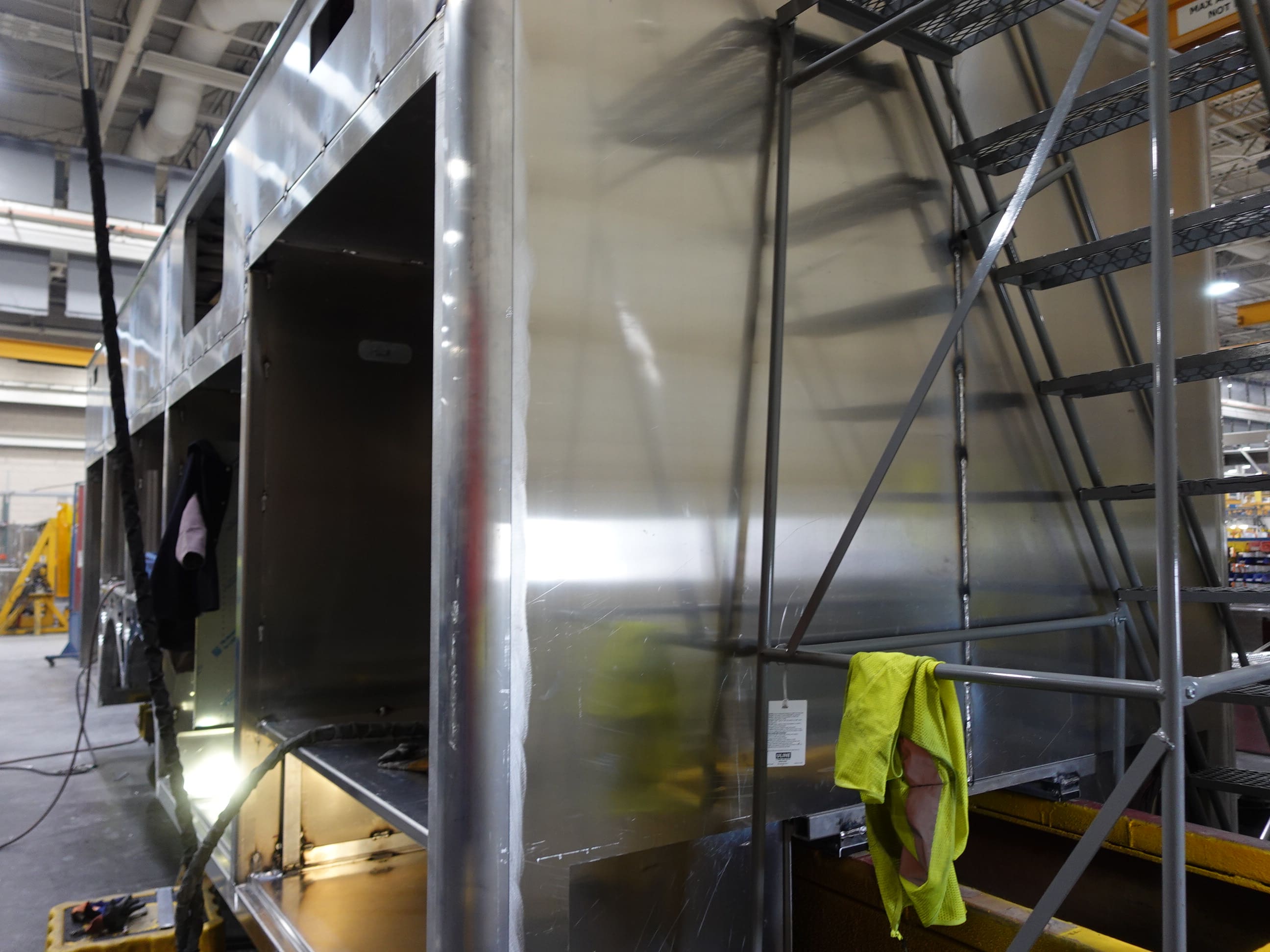

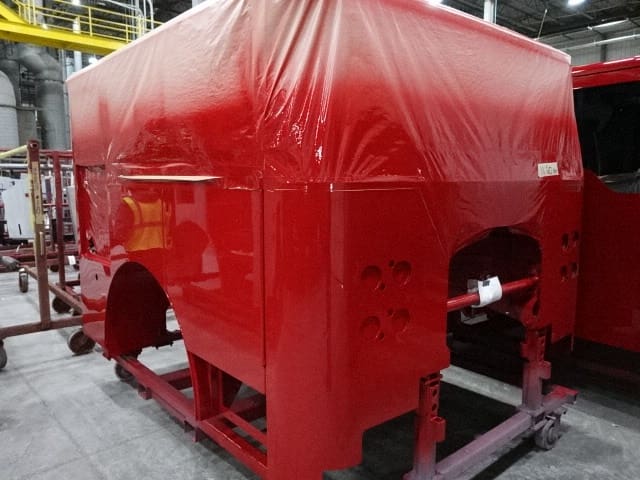

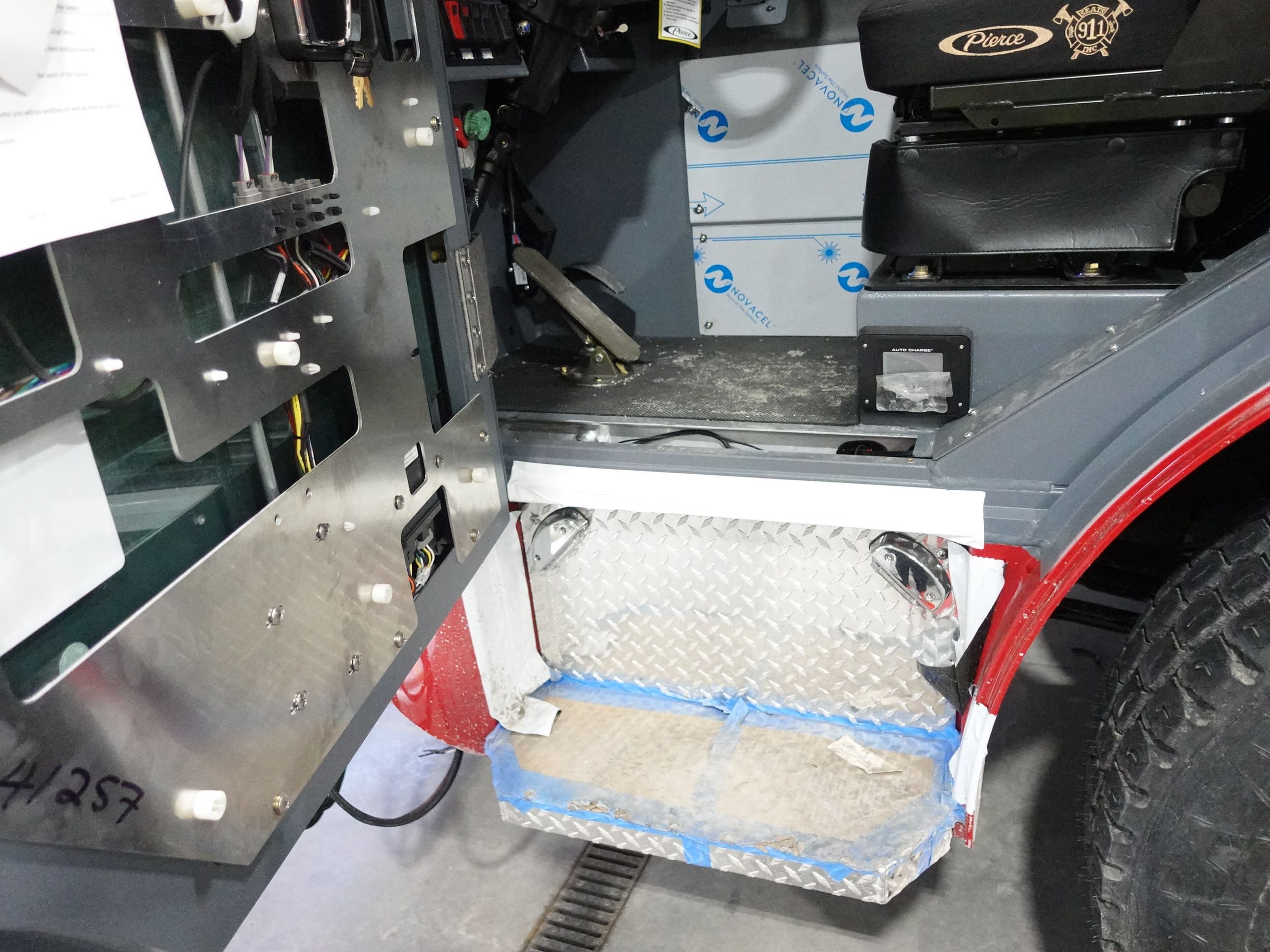

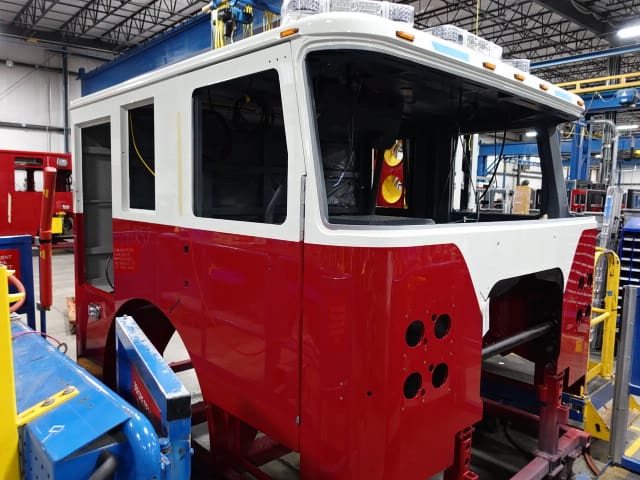

In this report, the cab completed paint and began initial assembly while the body continued fabrication.
12-05-25

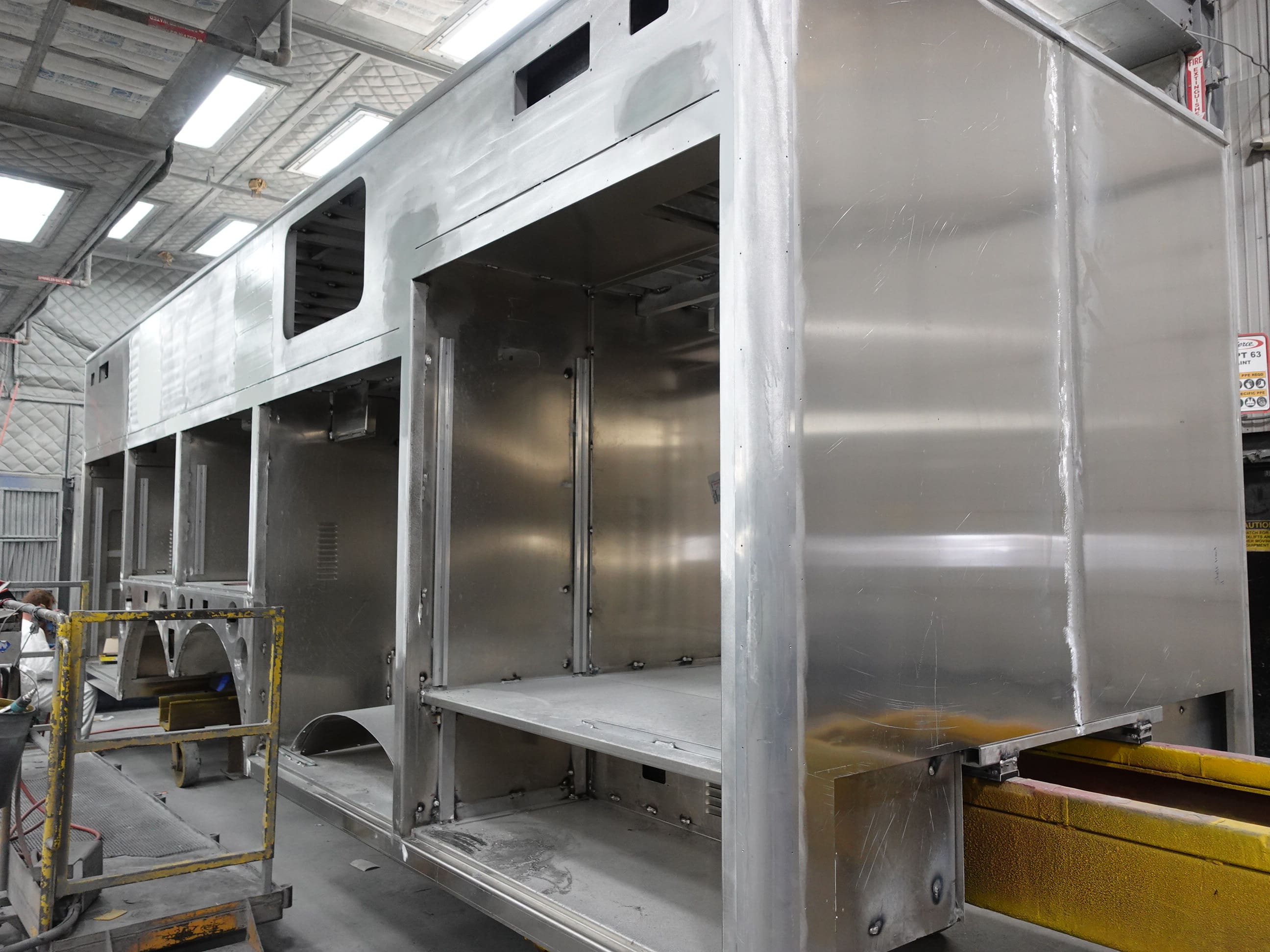

In this report, the cab completed fabrication and began the paint process while the body began fabrication.

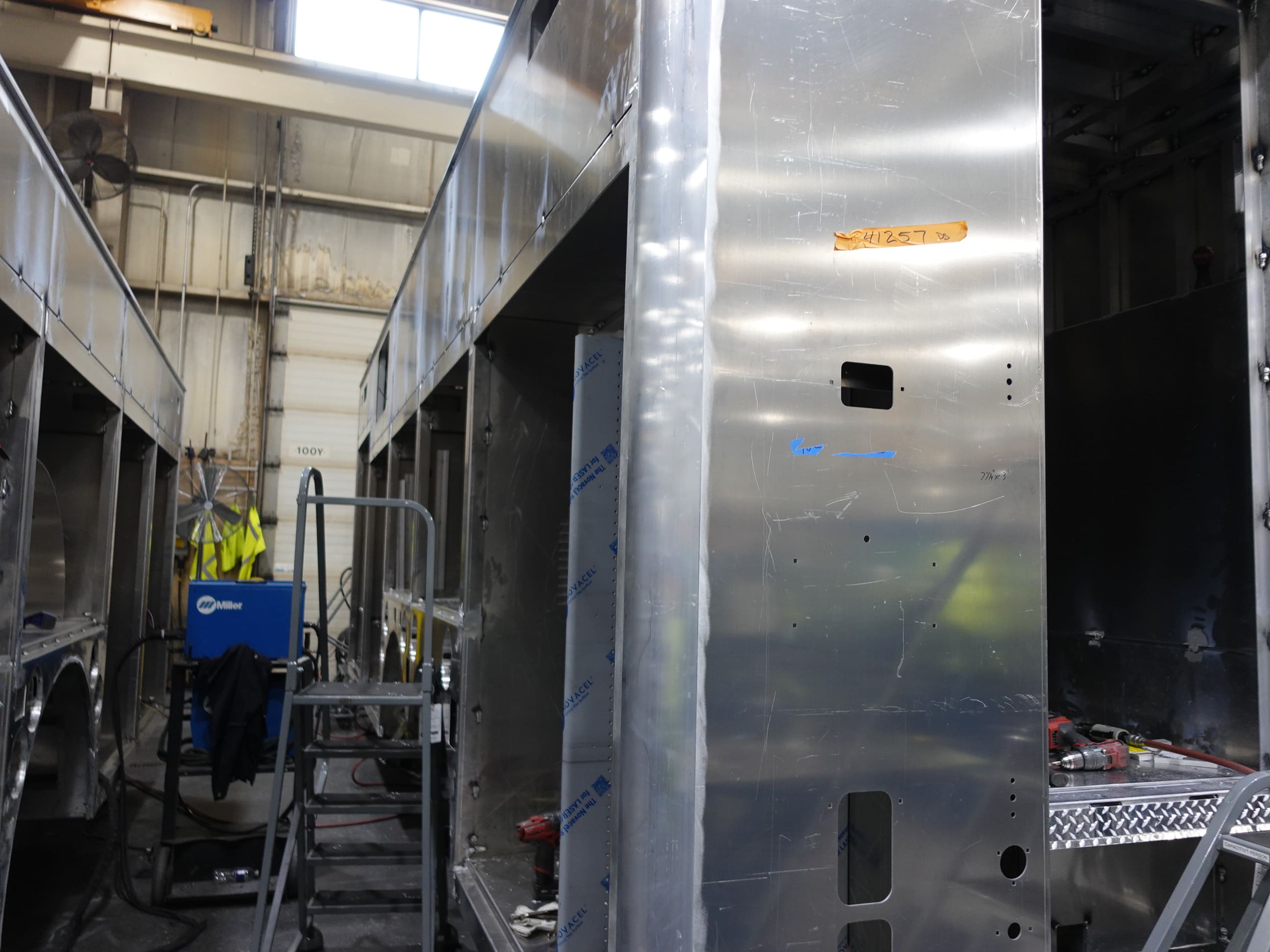

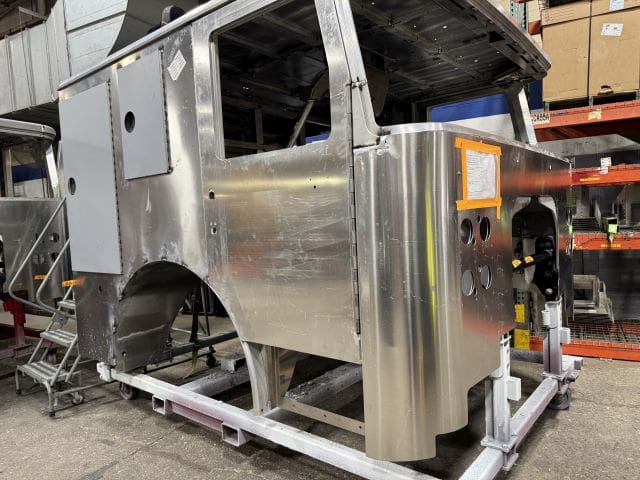

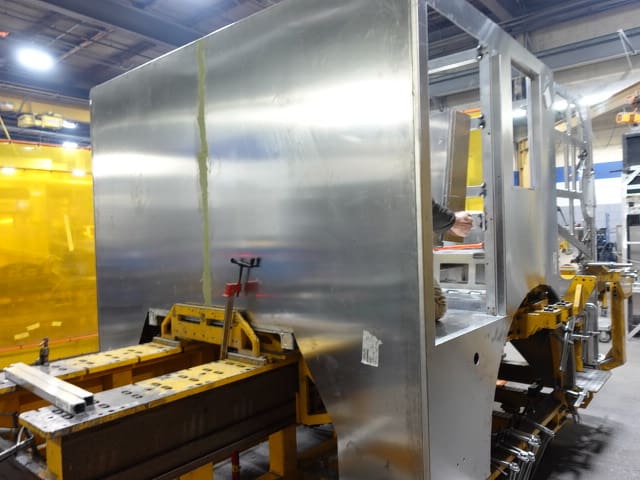

11-14-25

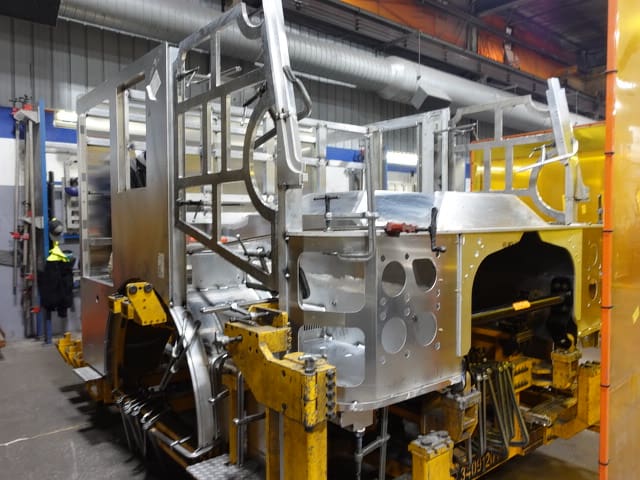

This new Pierce apparatus is now in production! In this report, the cab began fabrication
