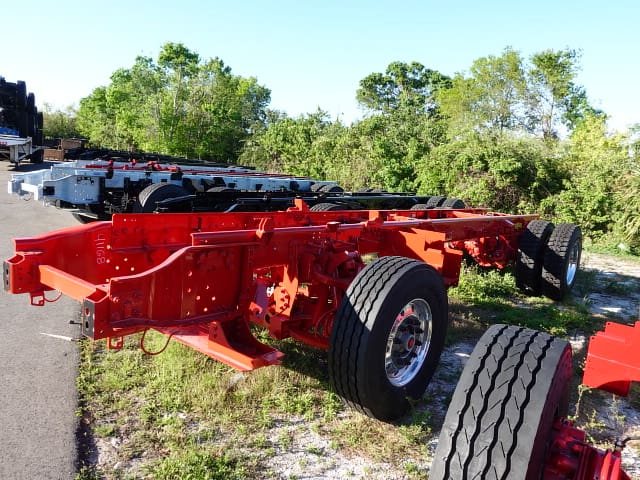

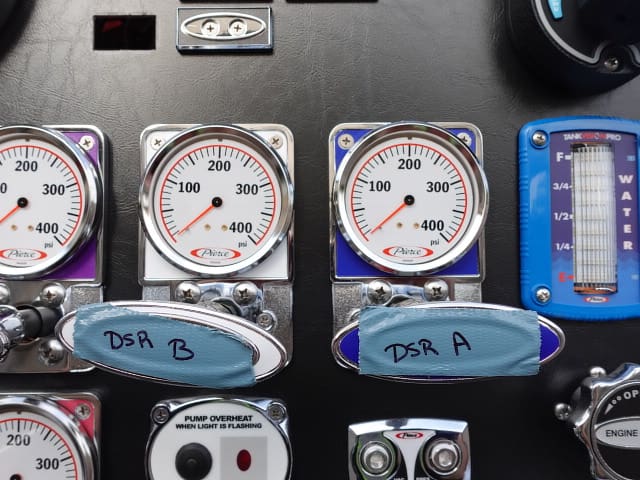

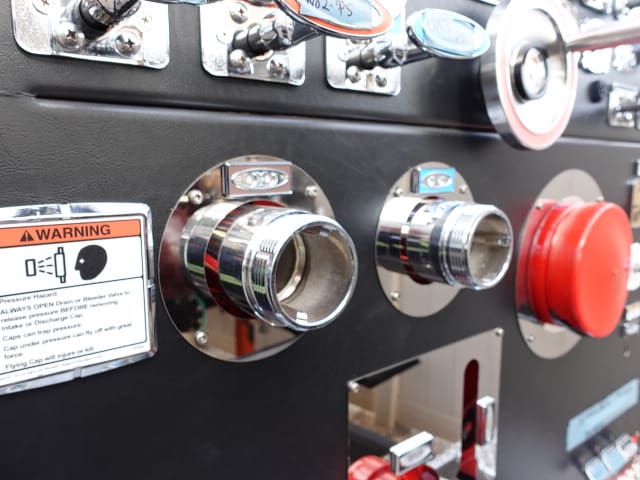

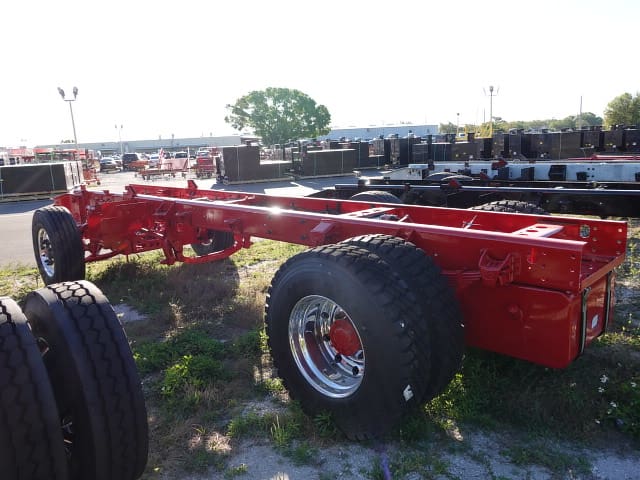

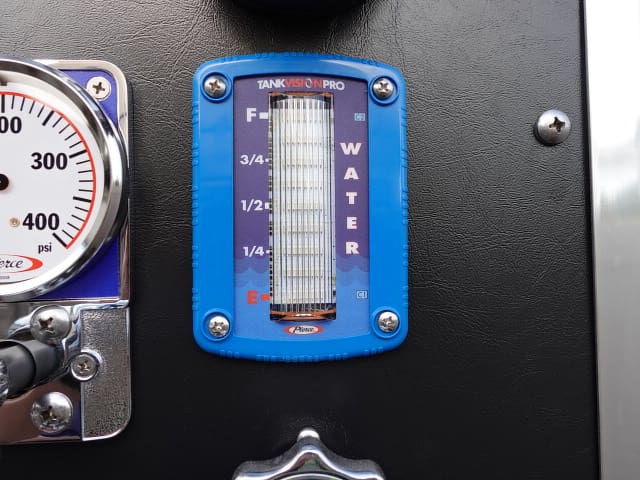

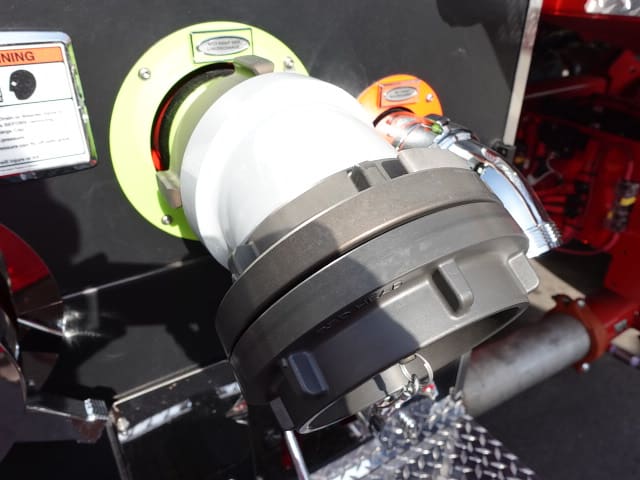

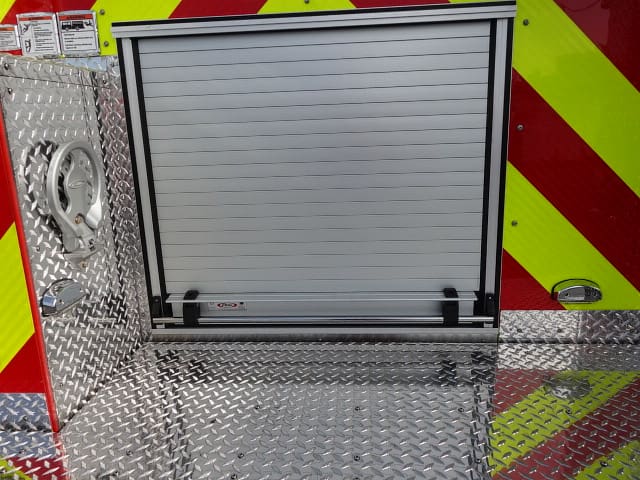

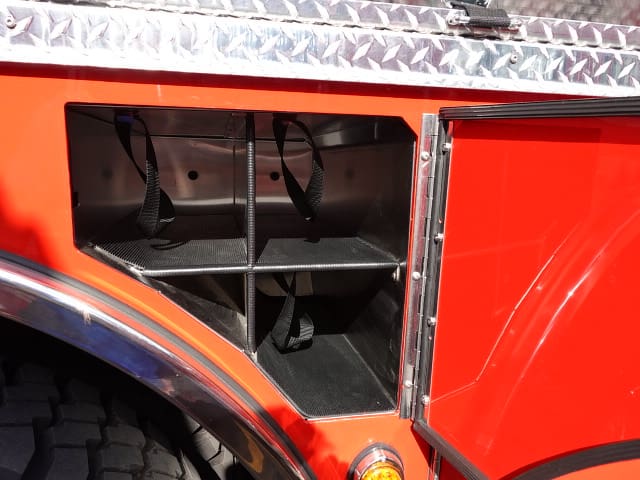

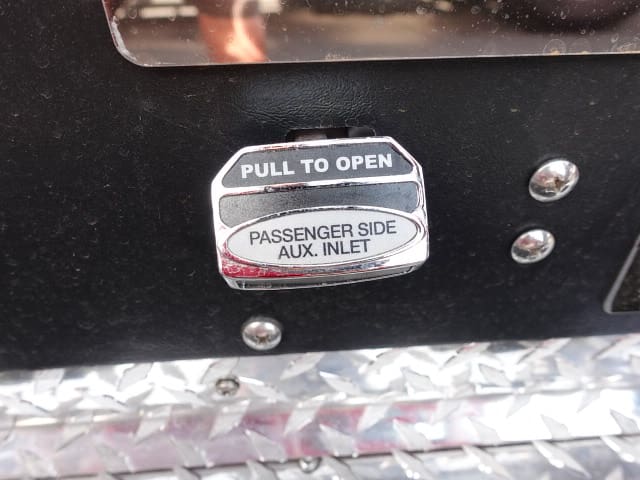

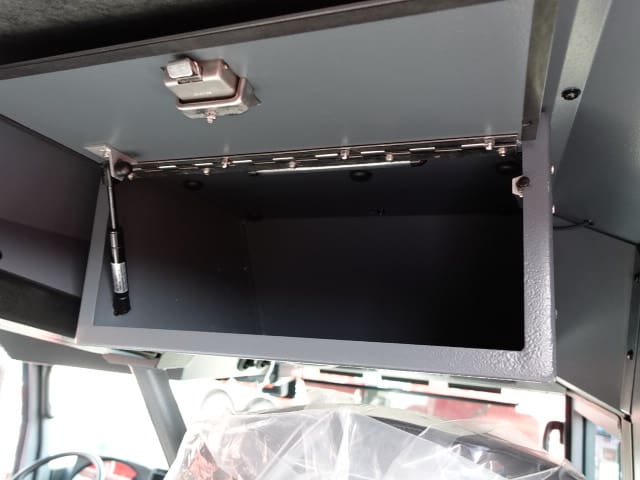

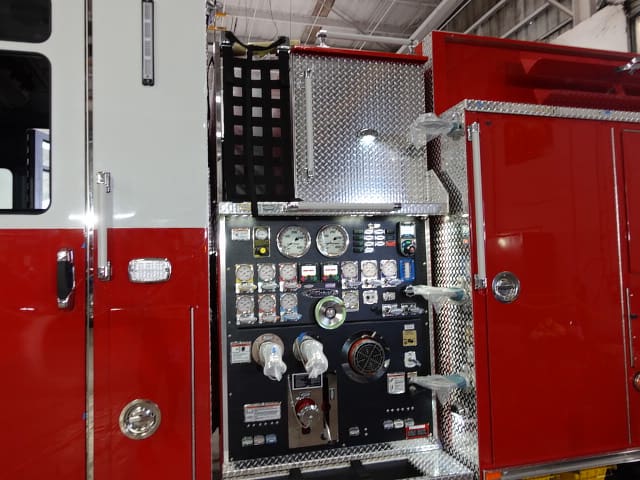

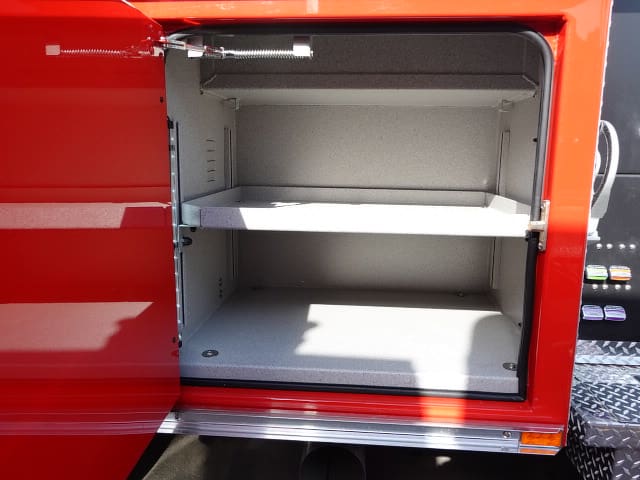

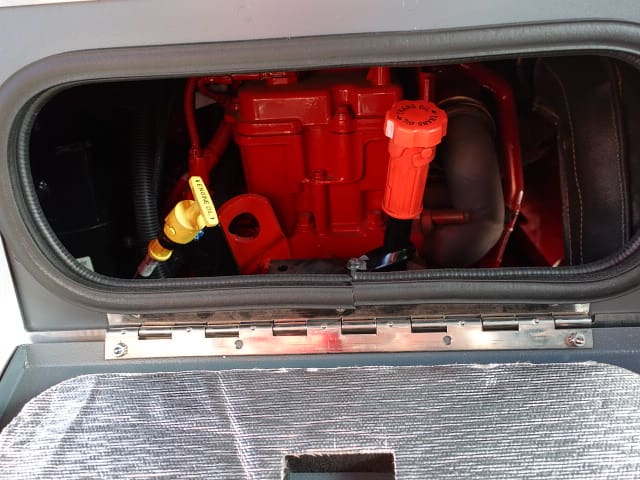

05-30-25

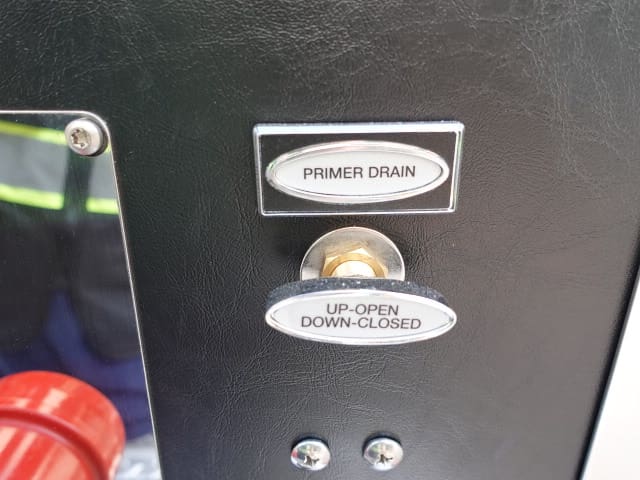

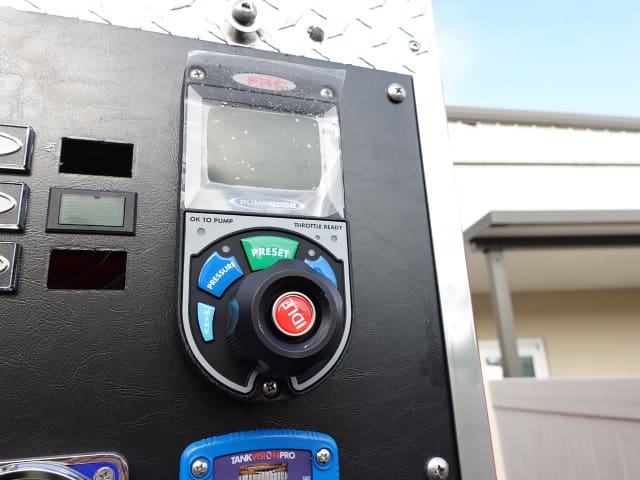

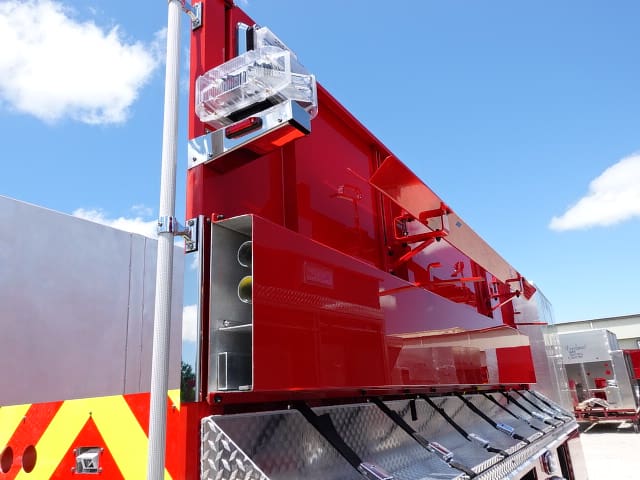

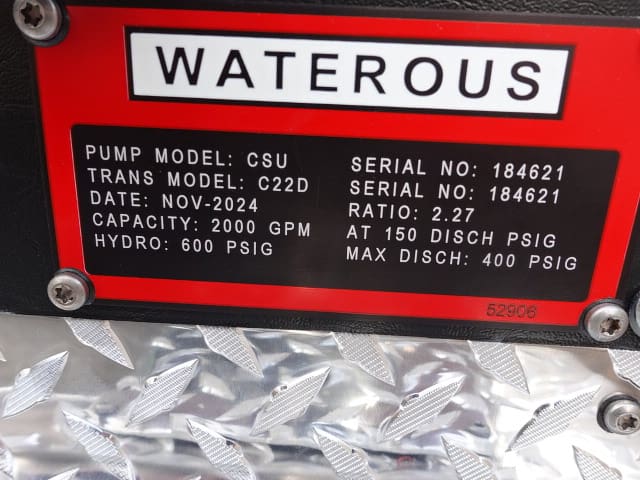

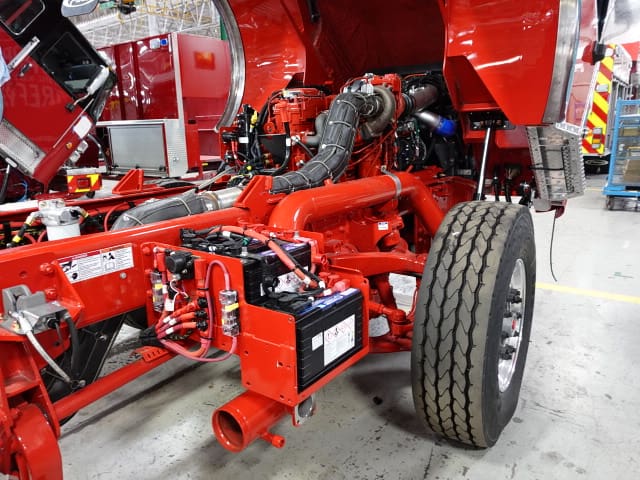

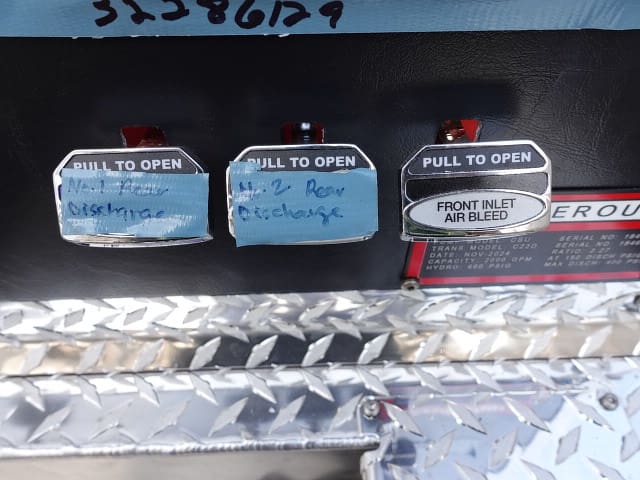

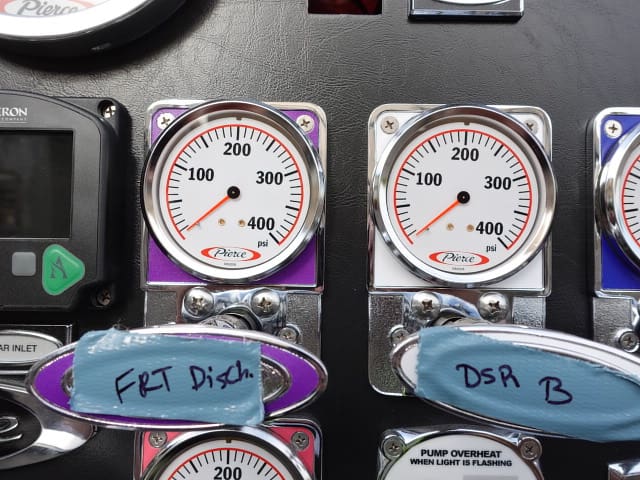

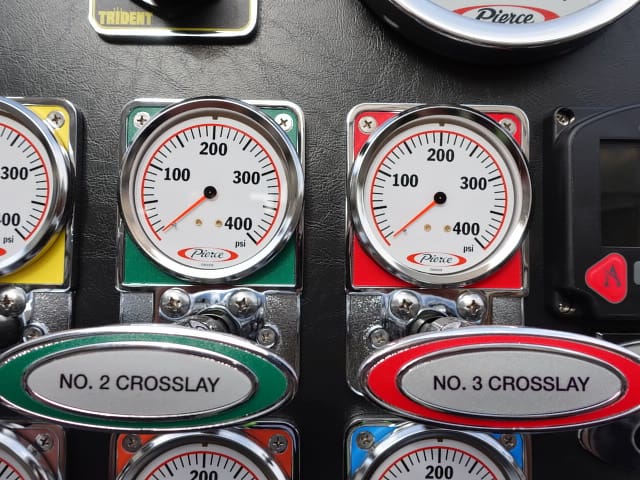

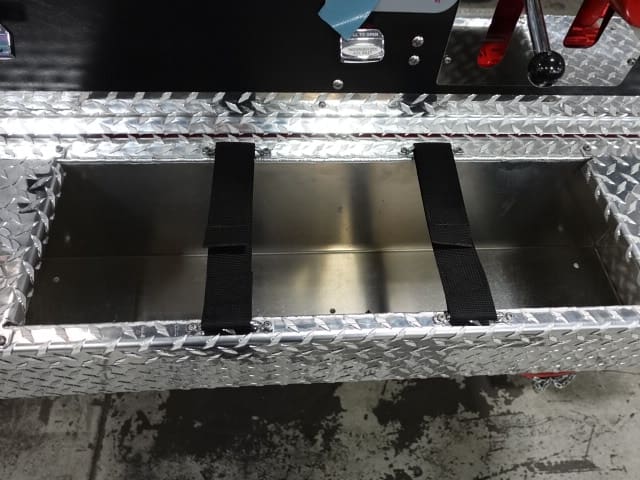

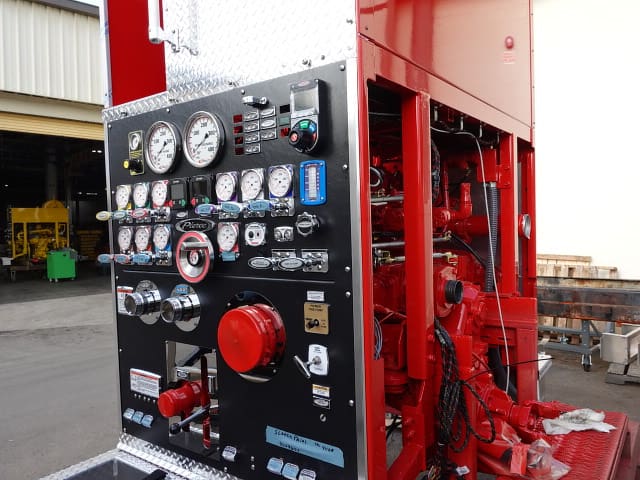

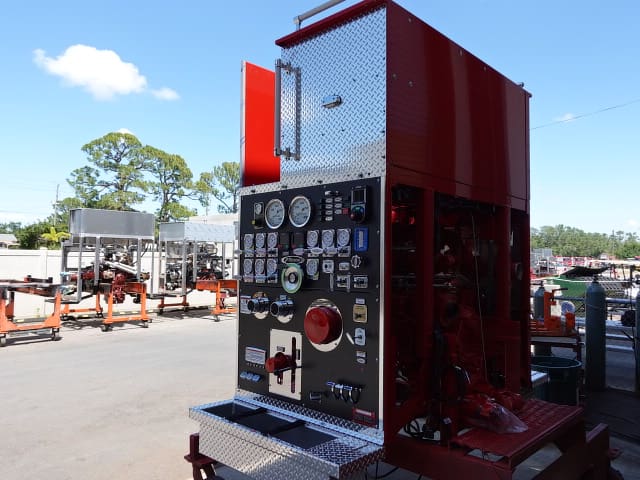

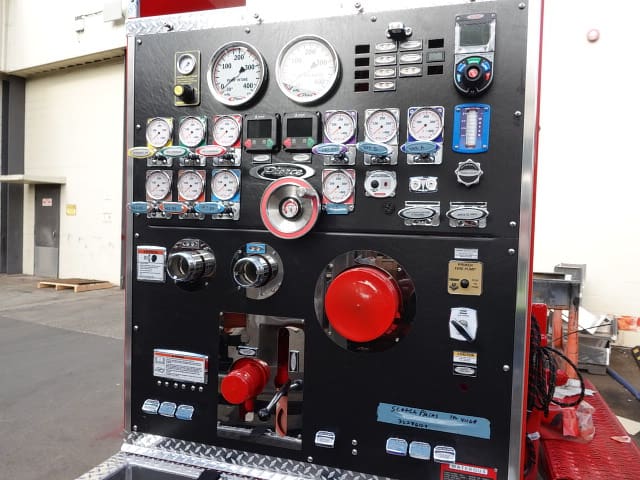

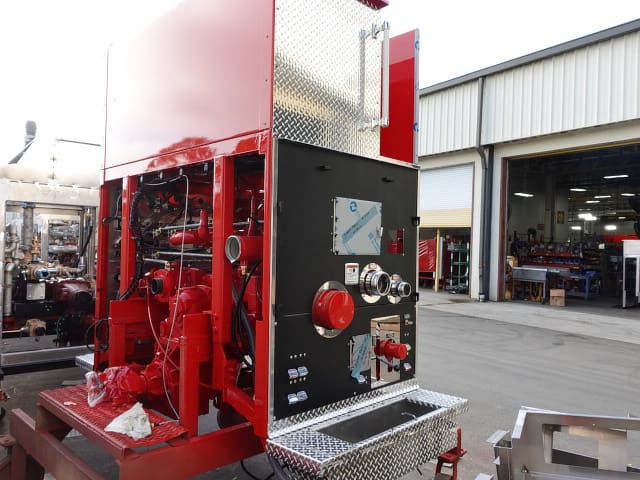

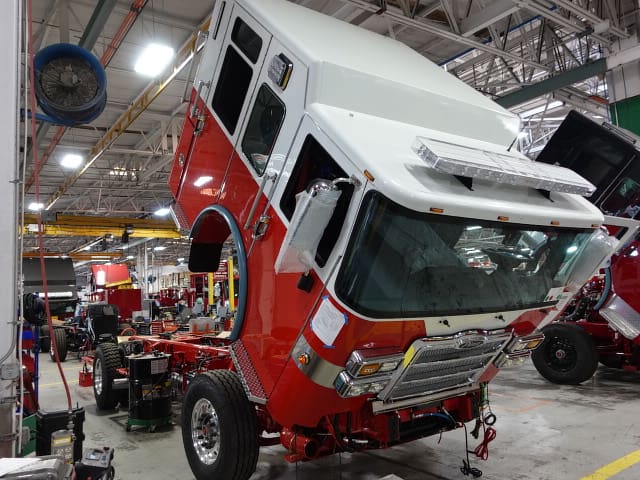

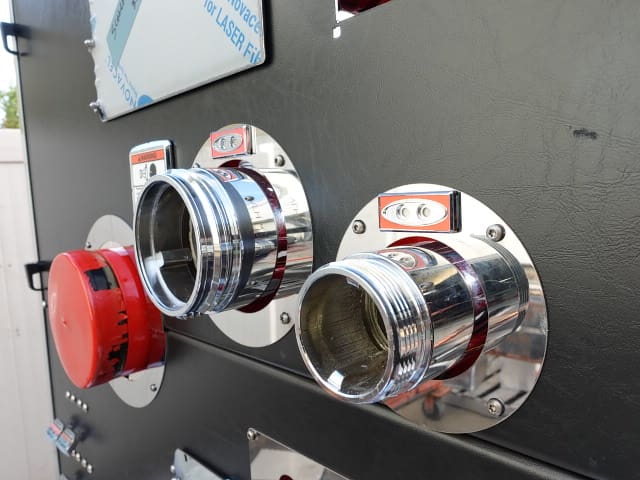

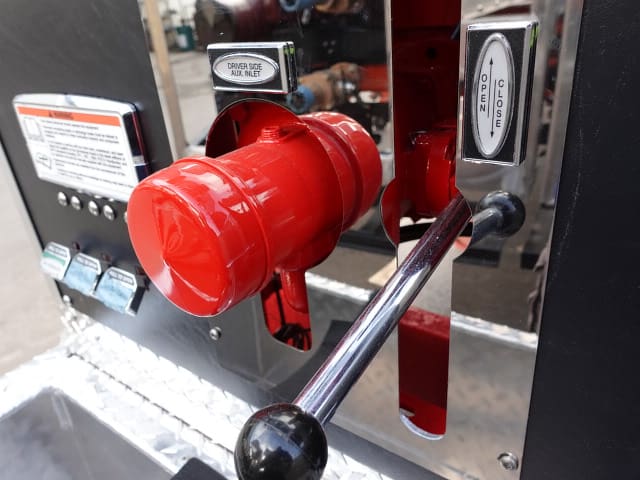

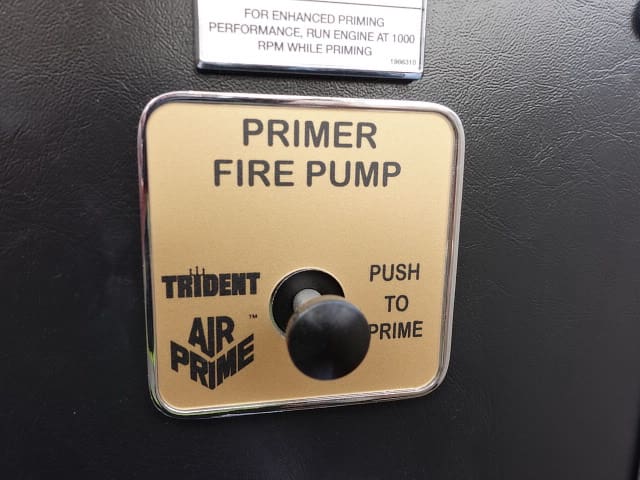

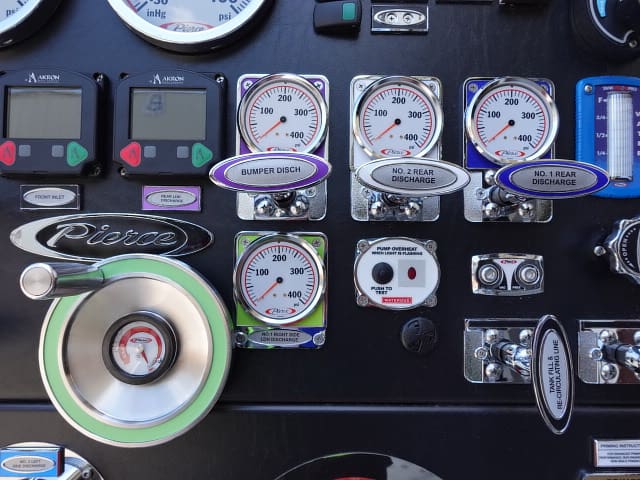

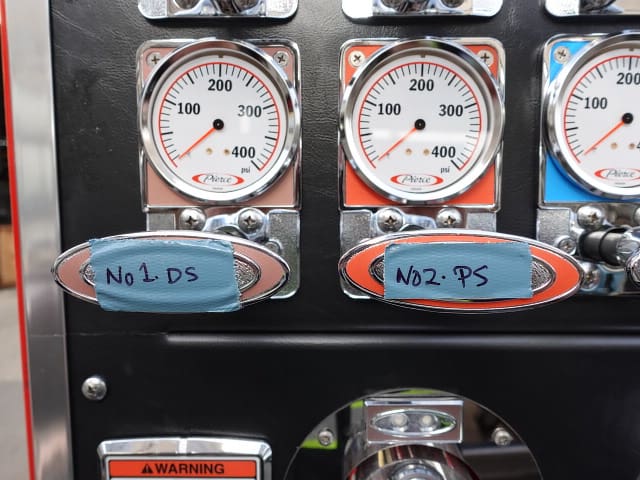

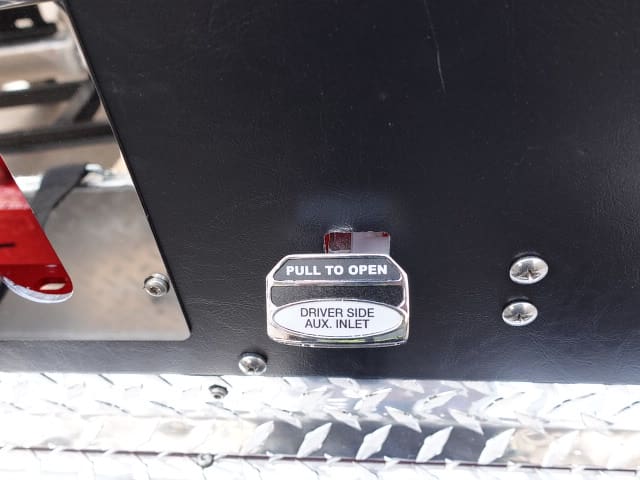

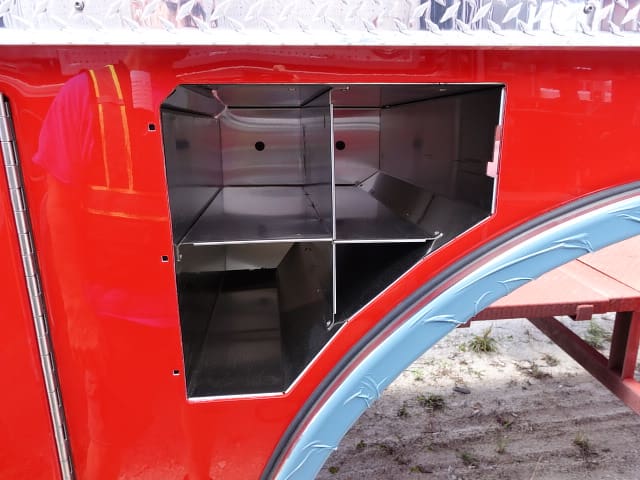

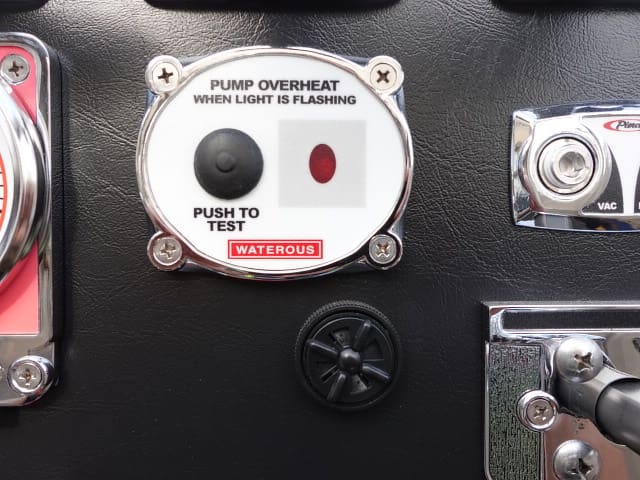

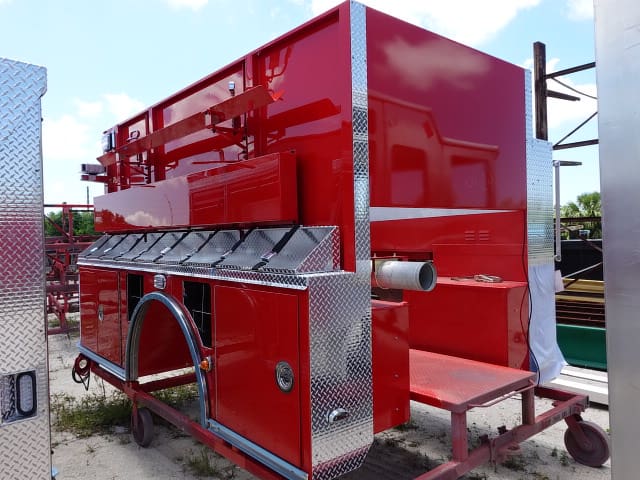

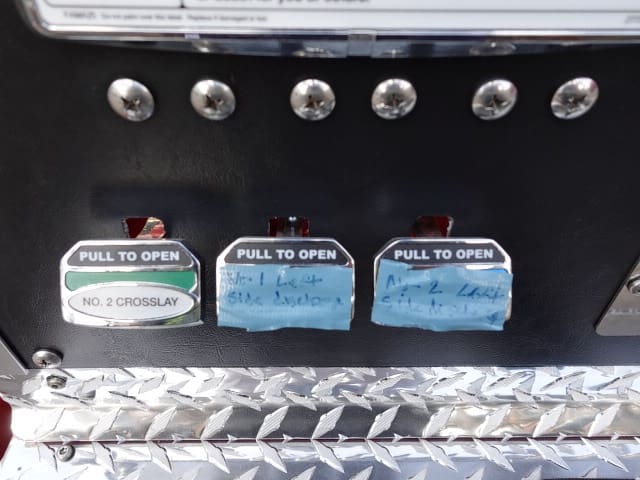

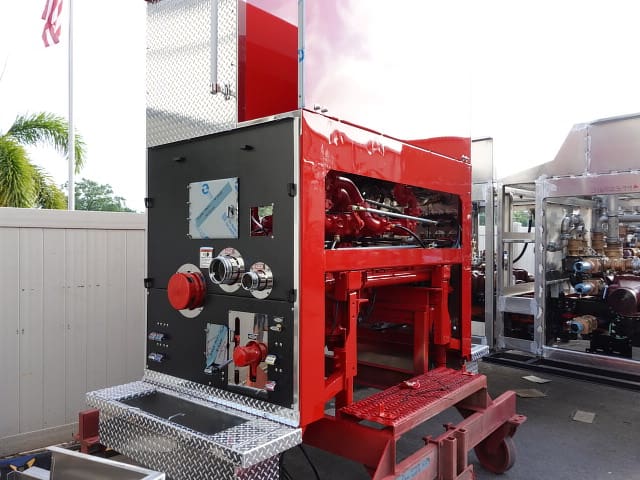

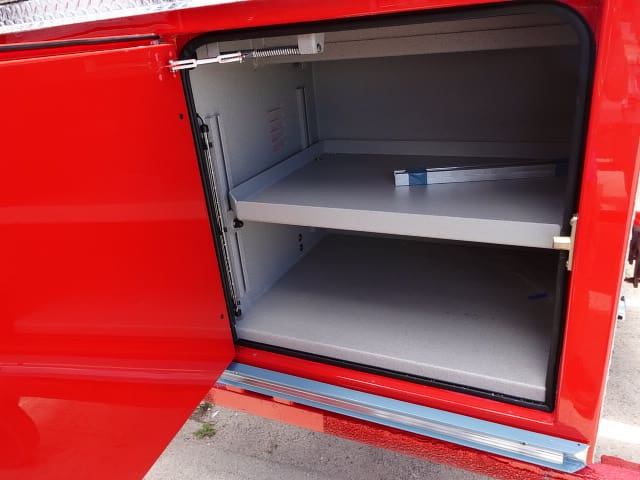

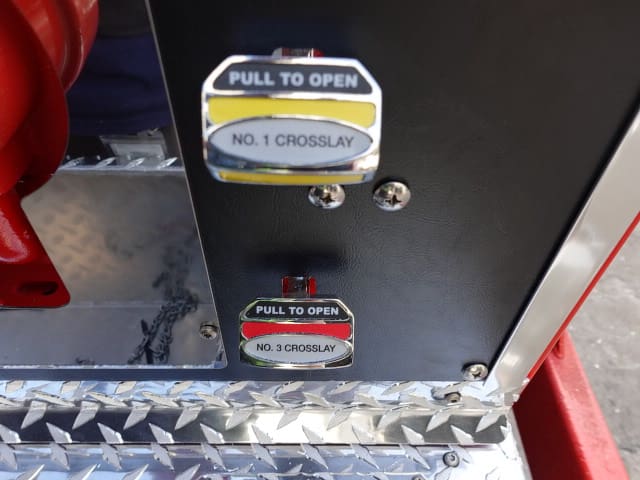

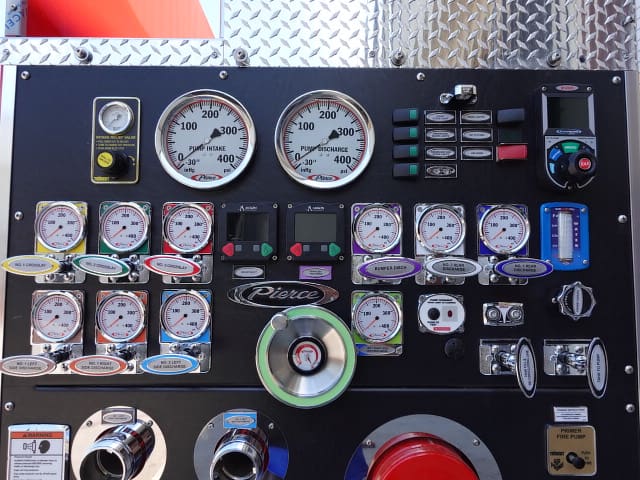

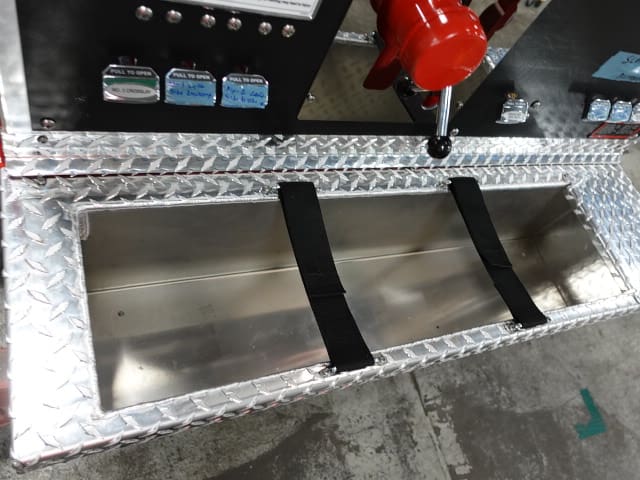

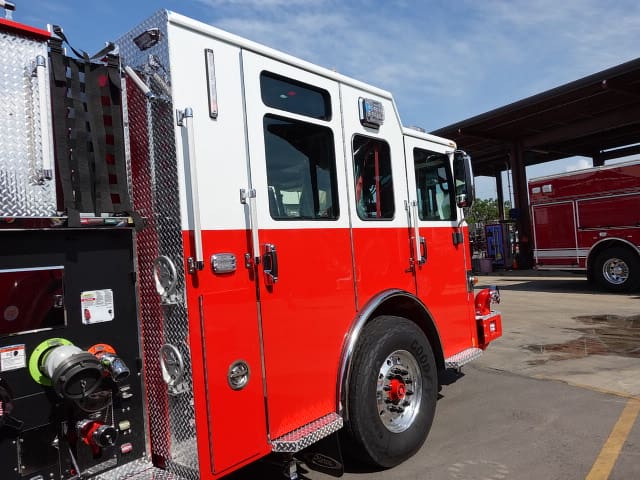

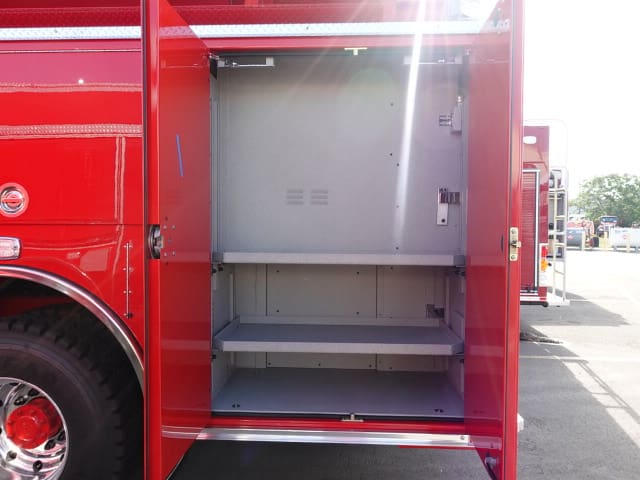

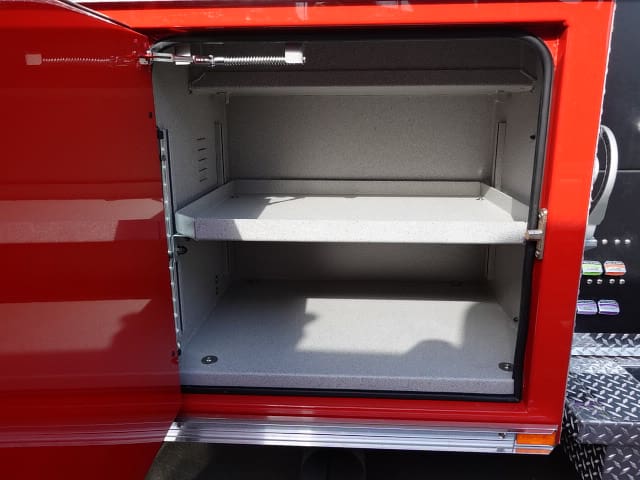

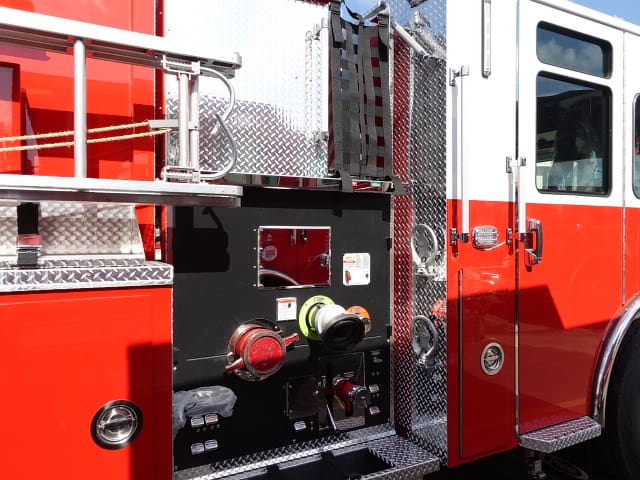

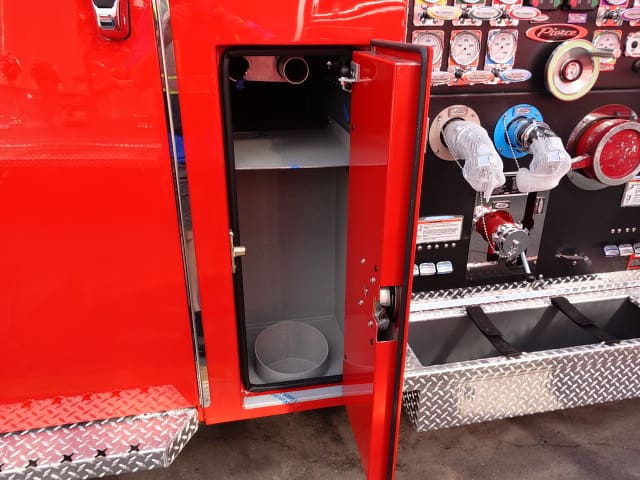

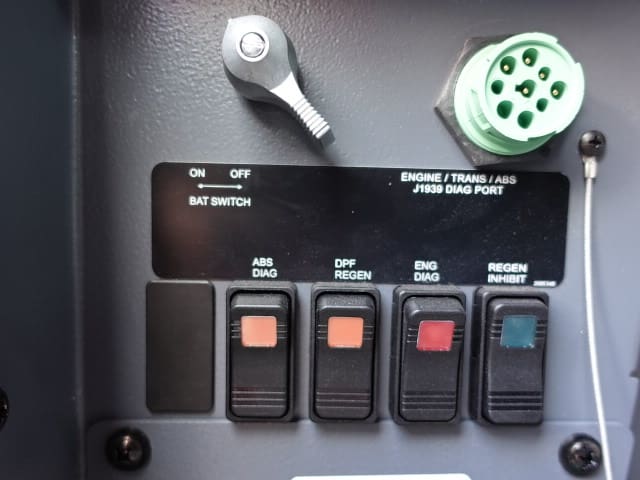

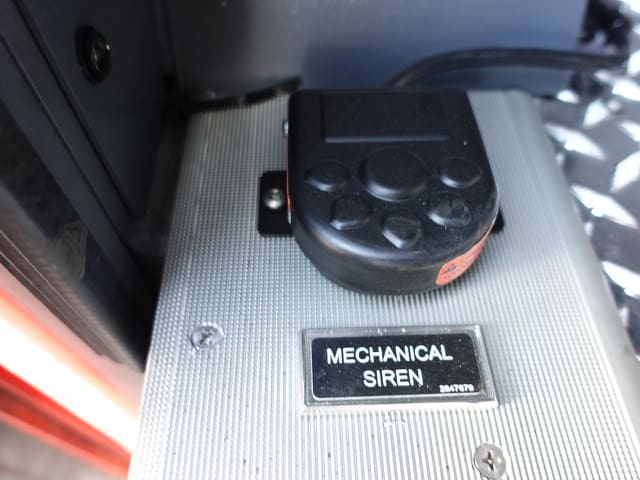

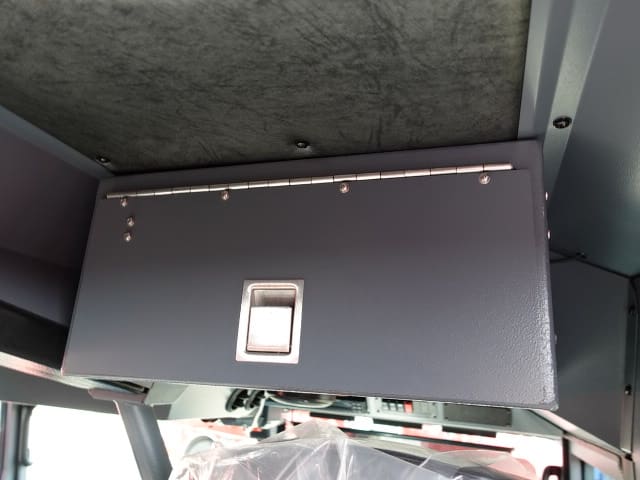

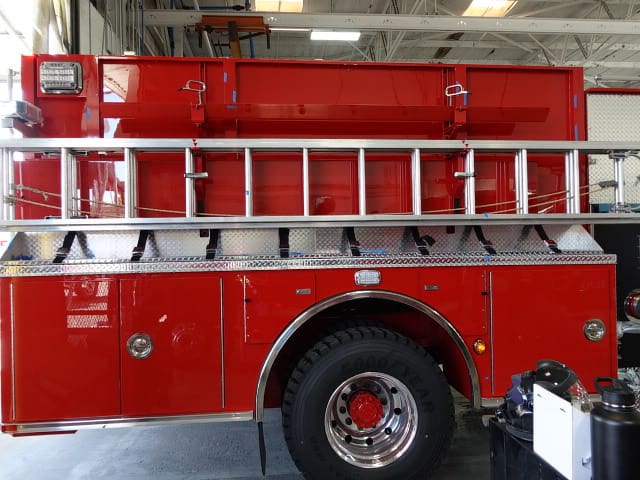

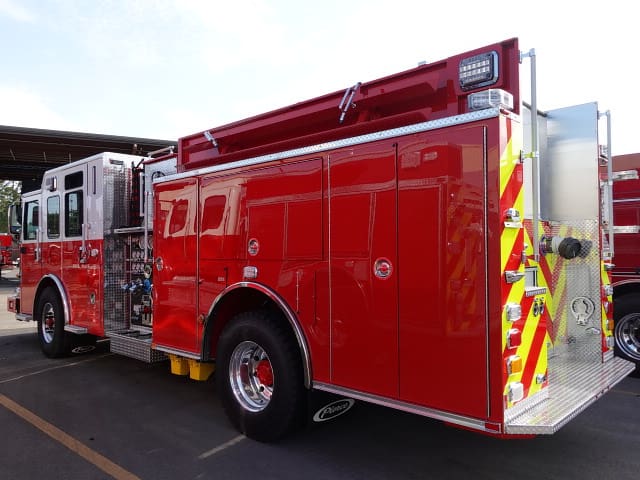

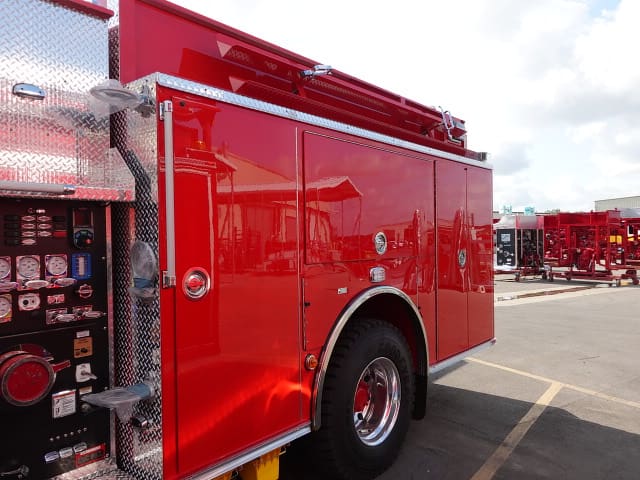

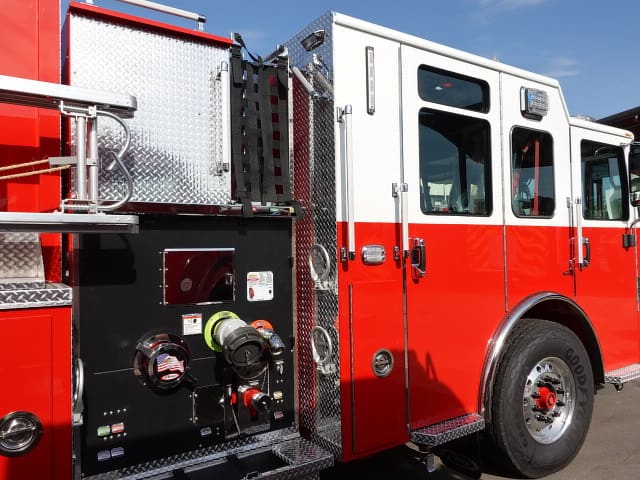

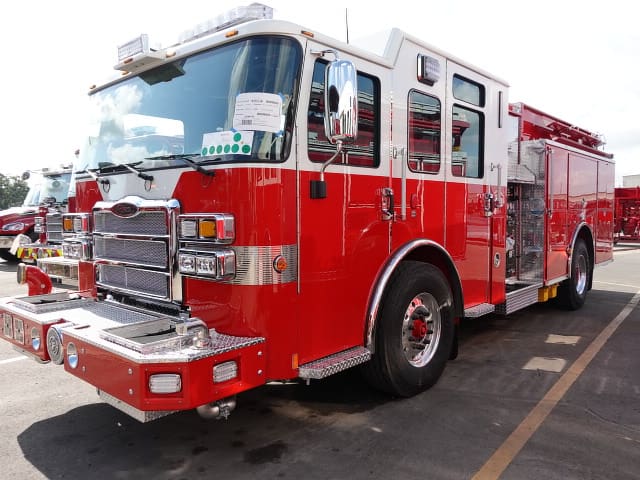

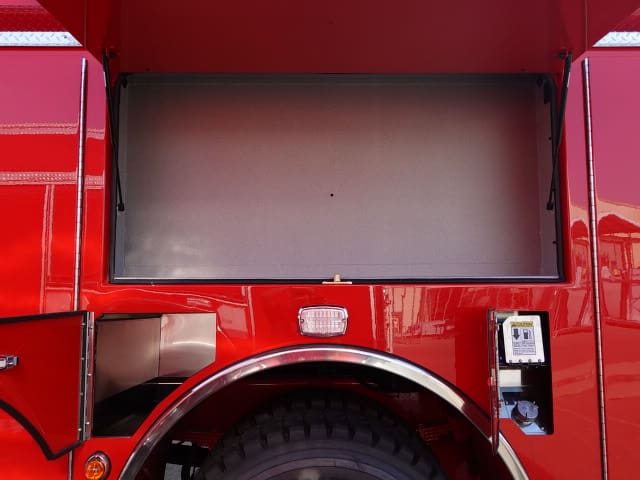

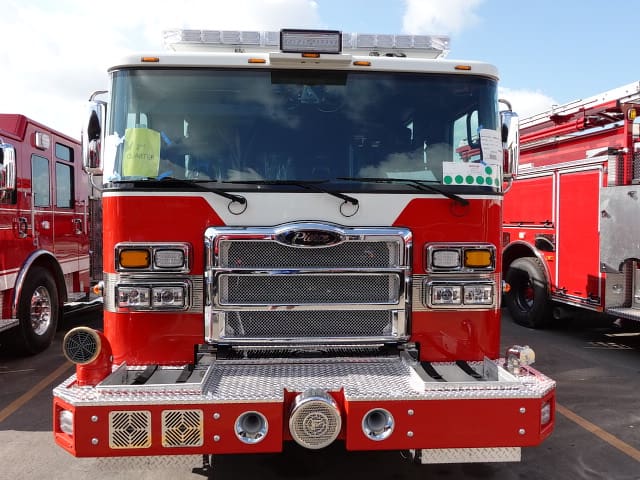

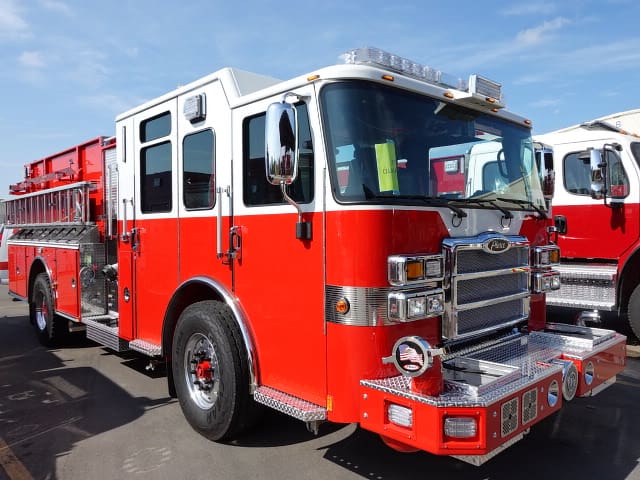

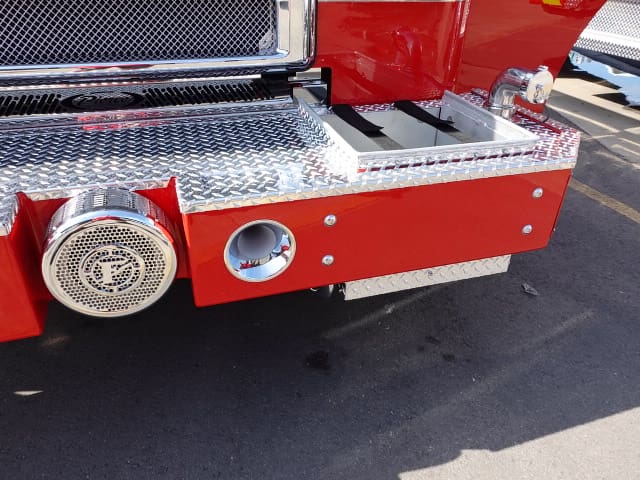

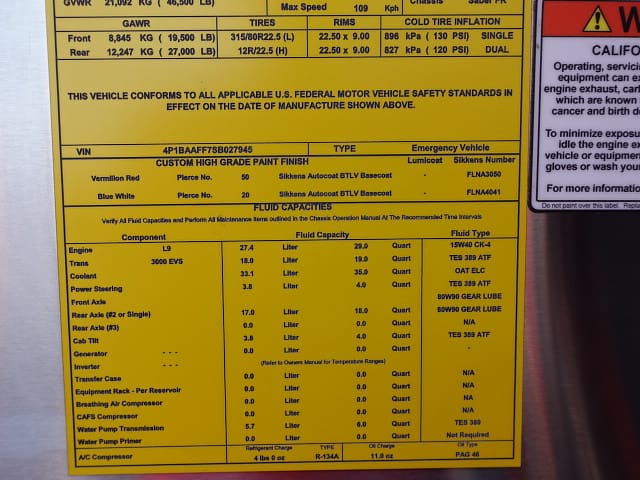

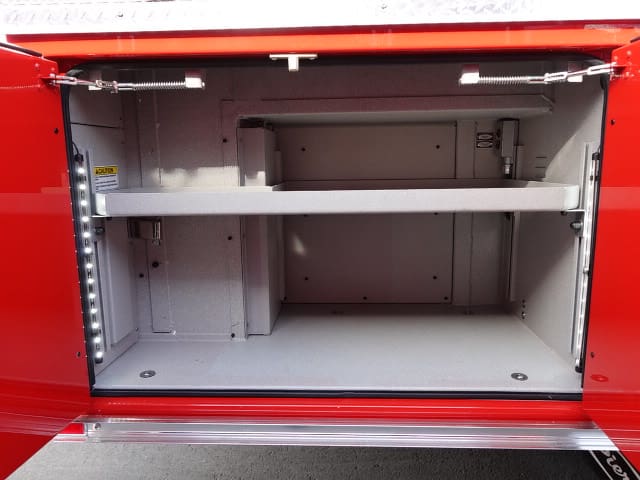

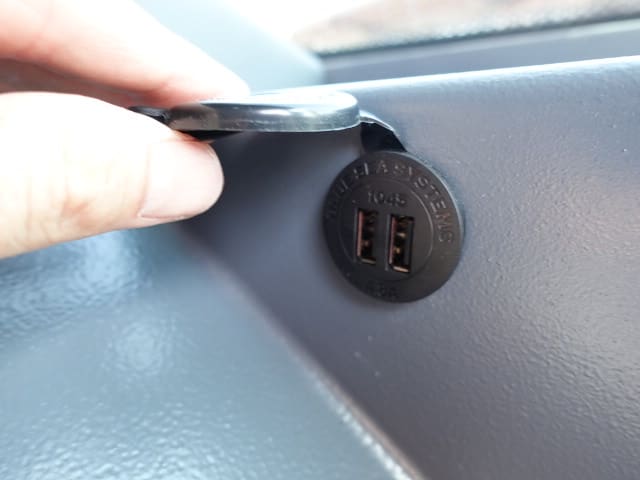

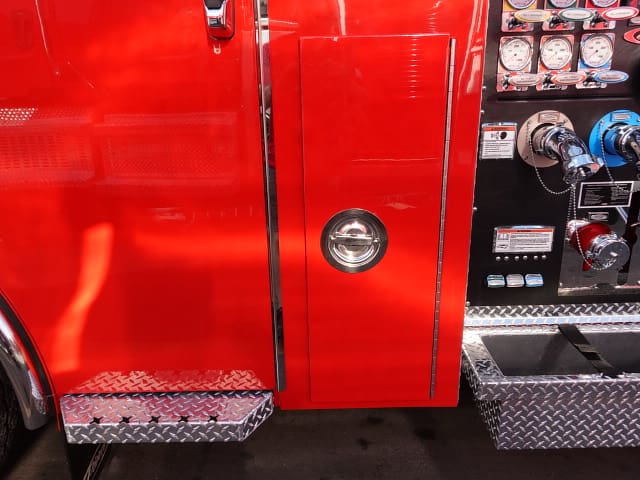

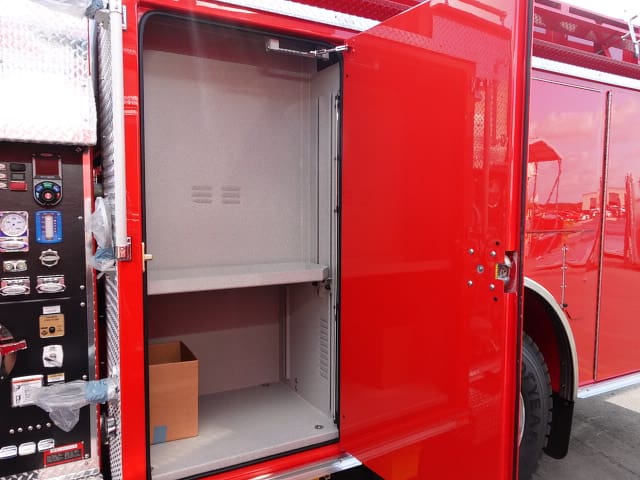

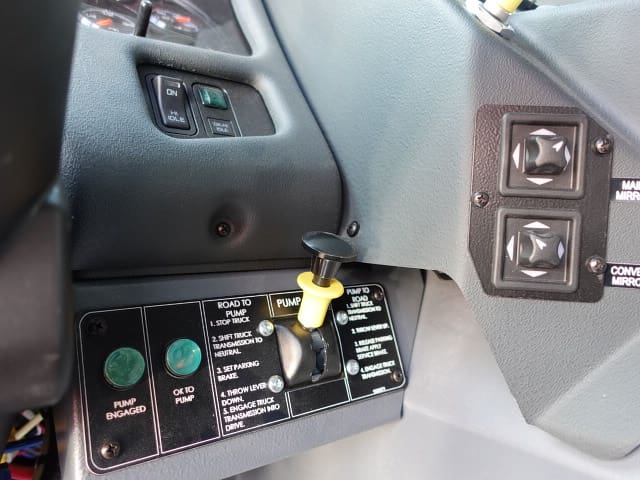

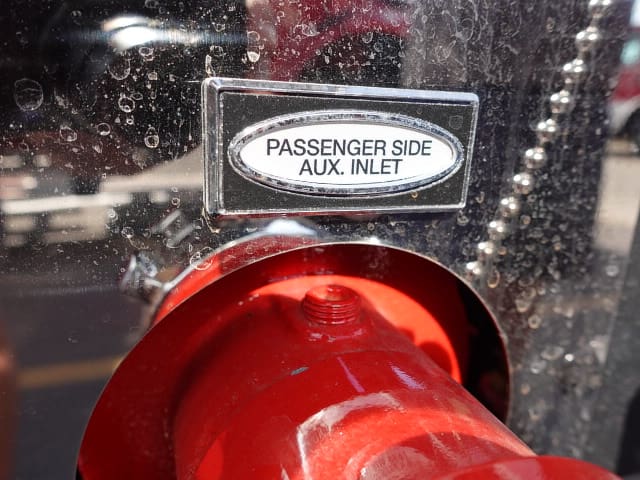

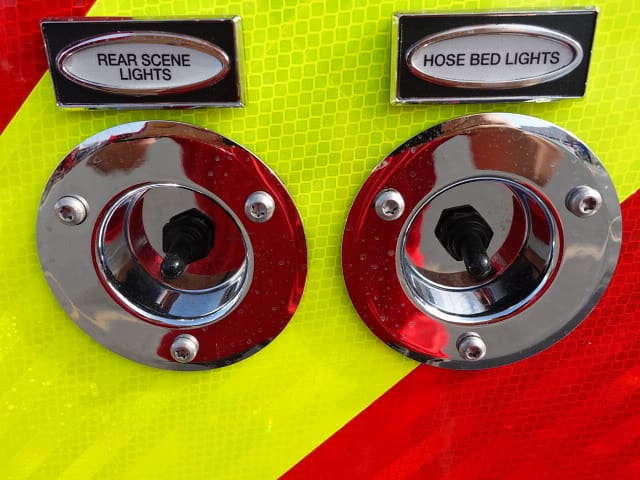

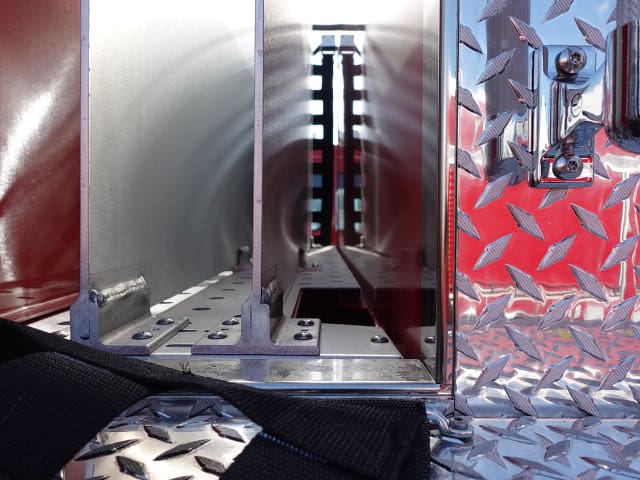

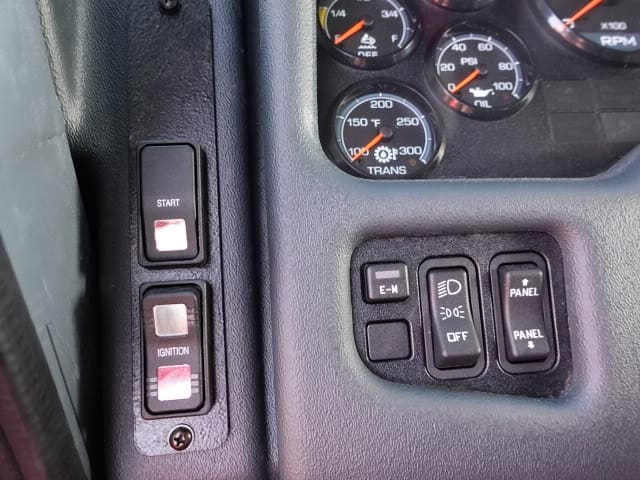

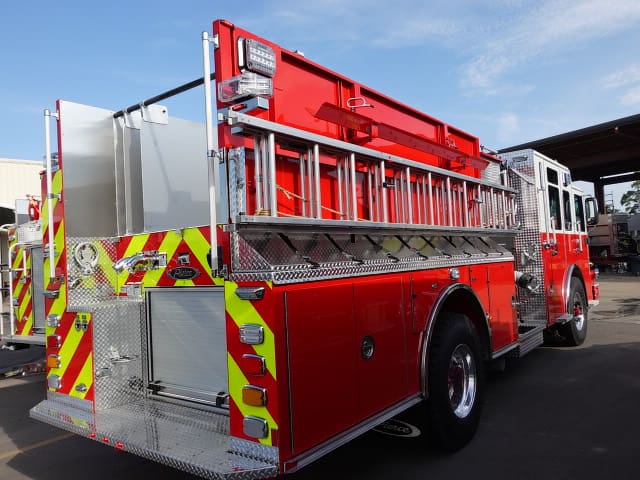

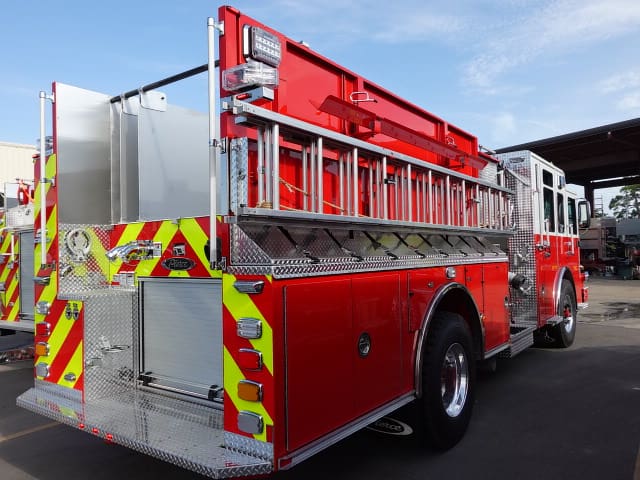

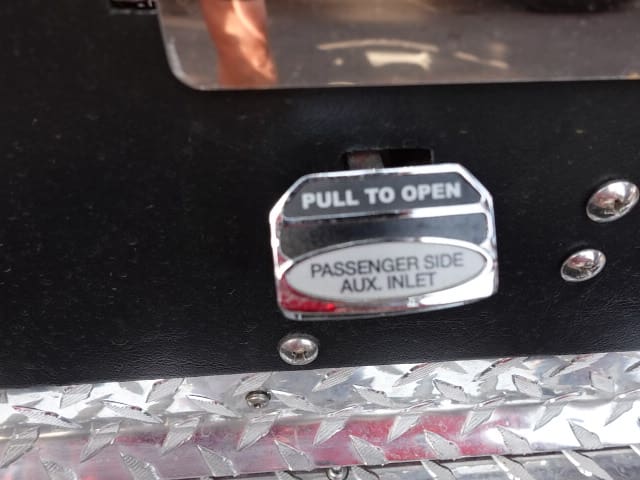

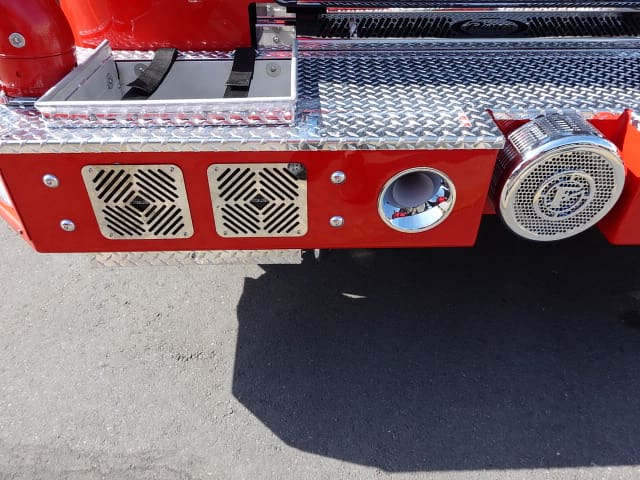

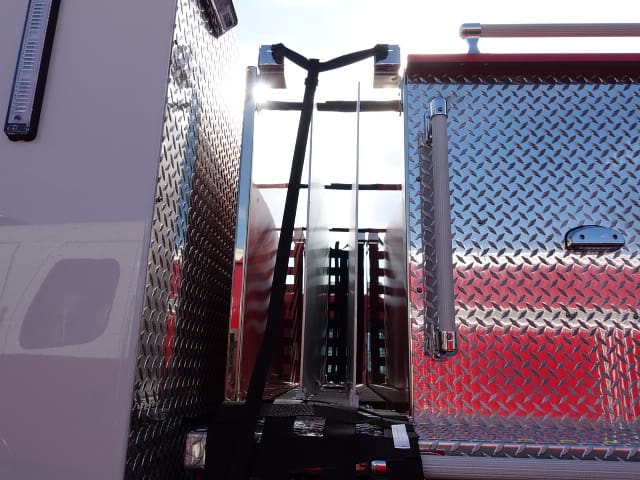

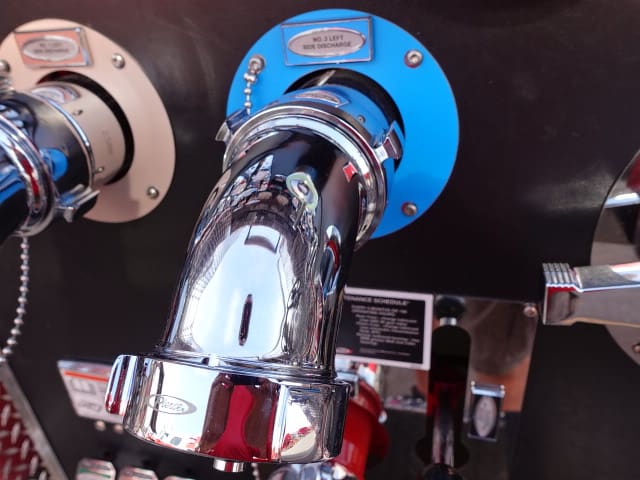

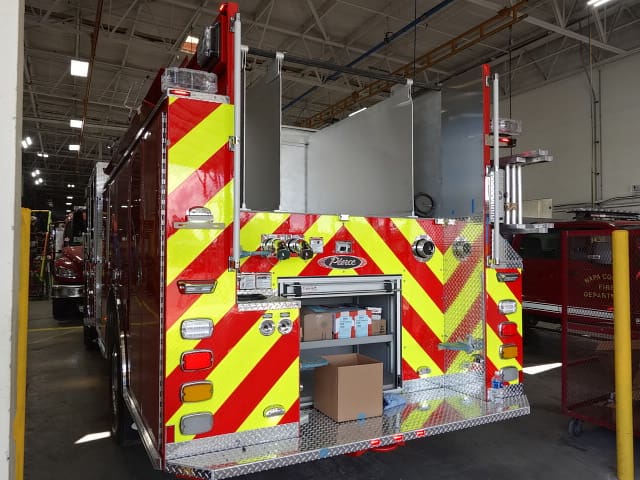

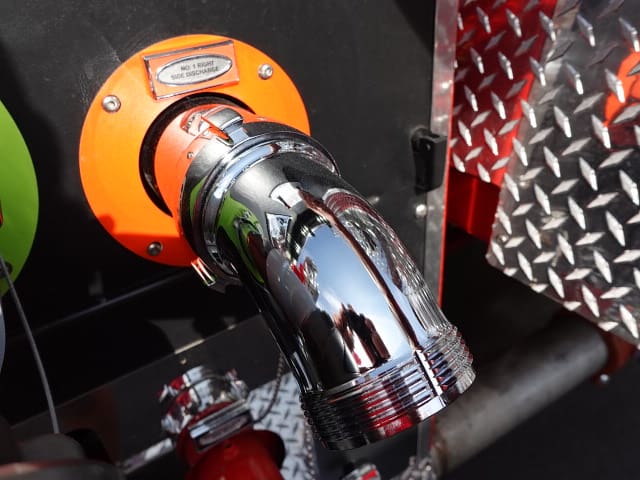

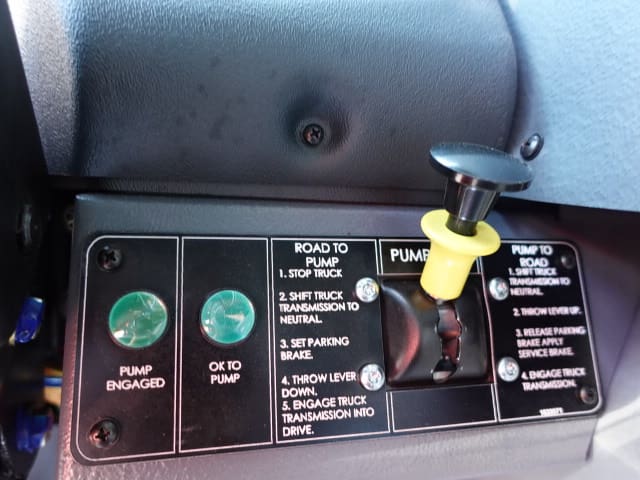

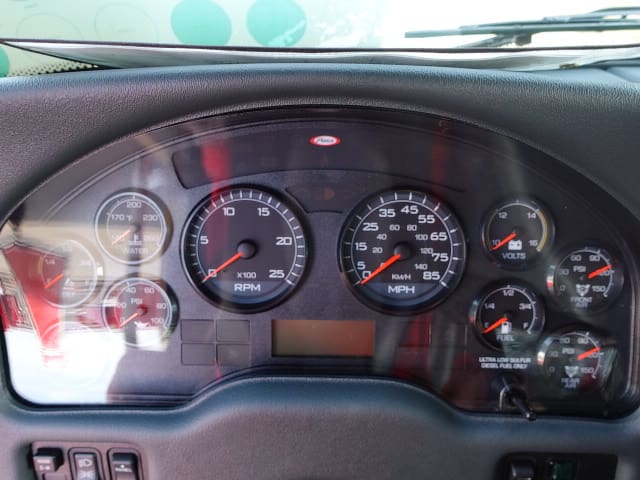

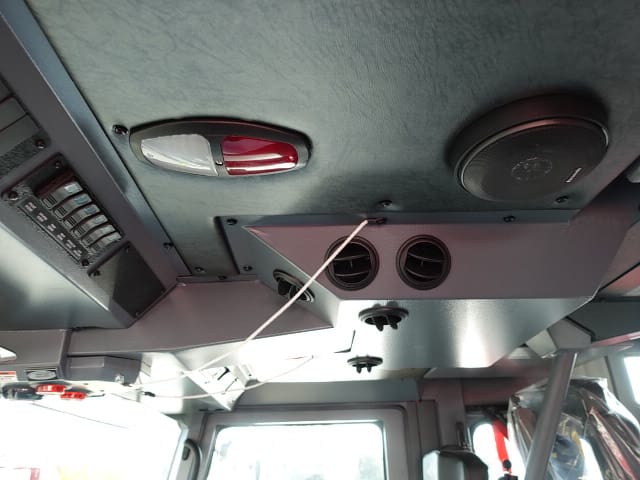

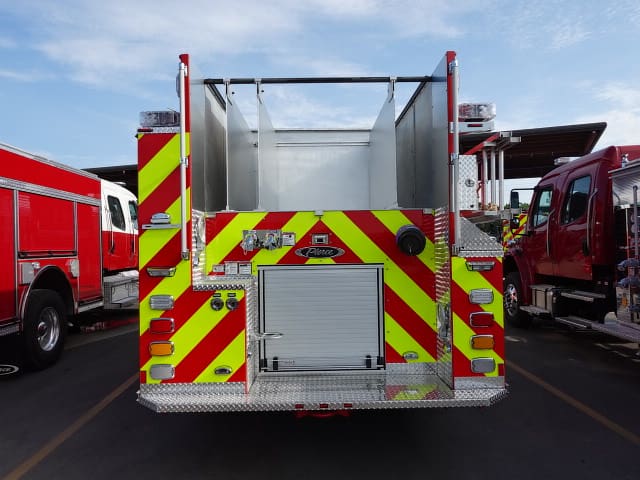

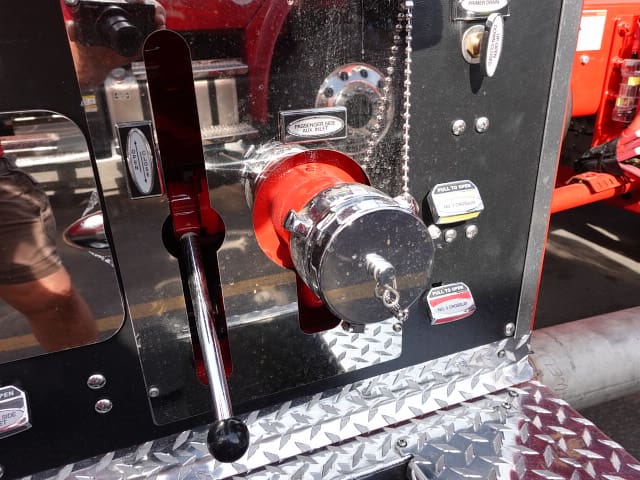

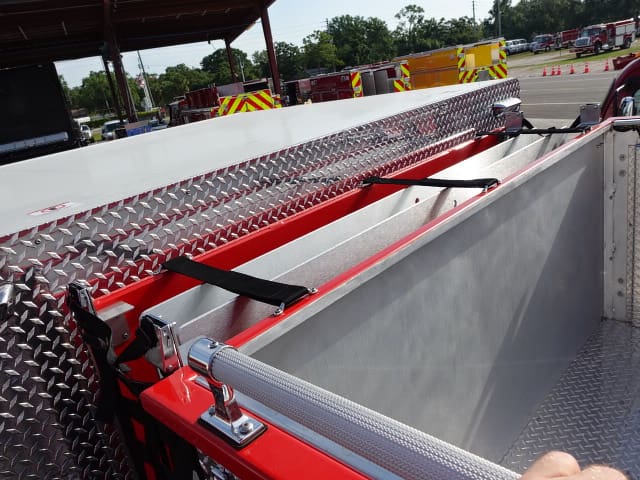

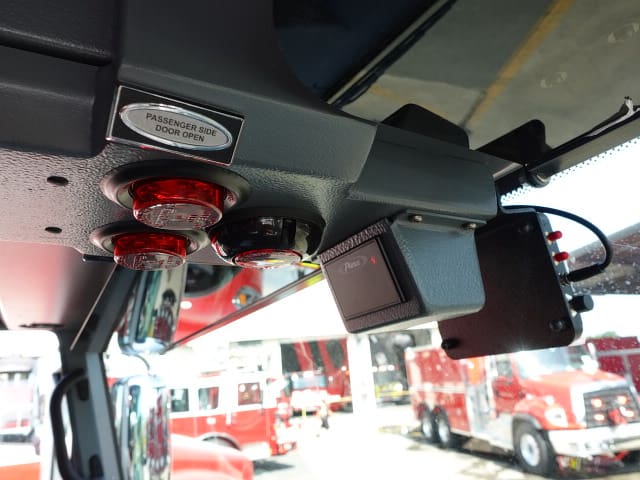

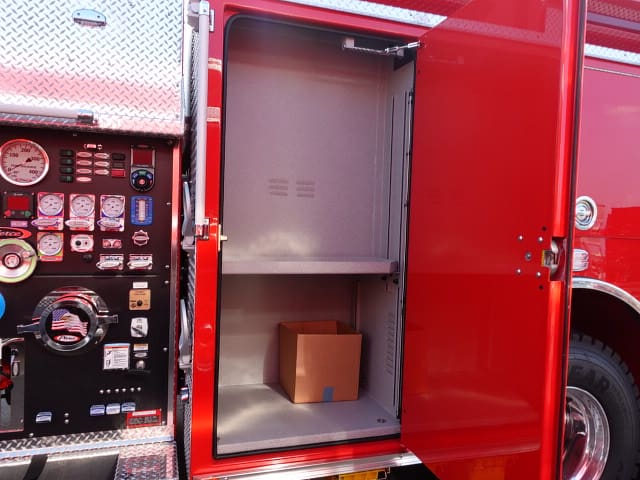

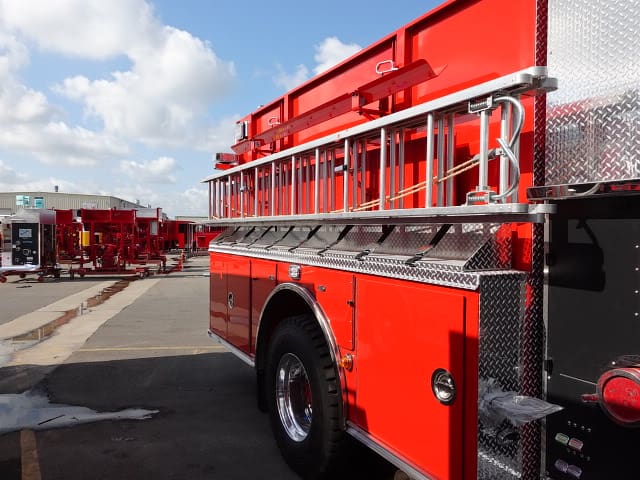

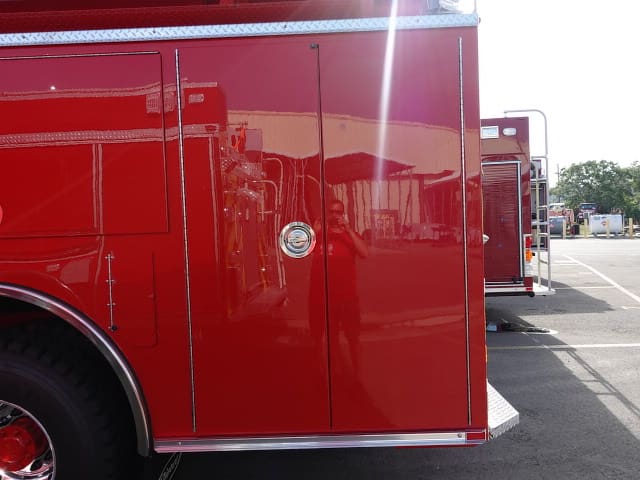

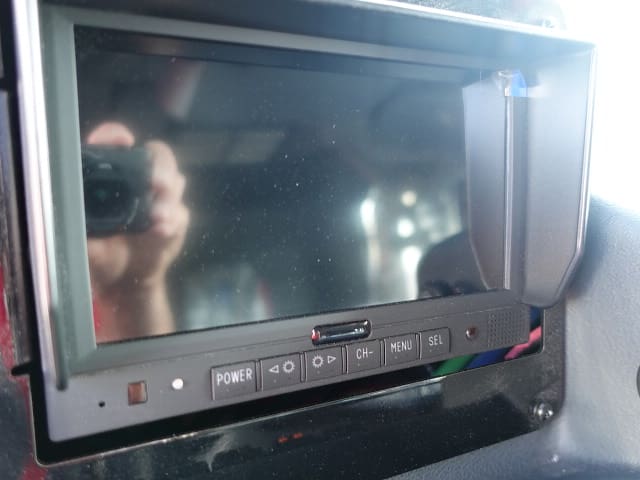

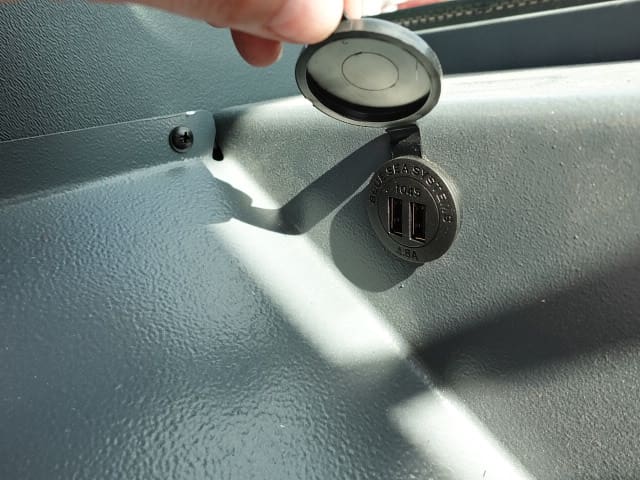

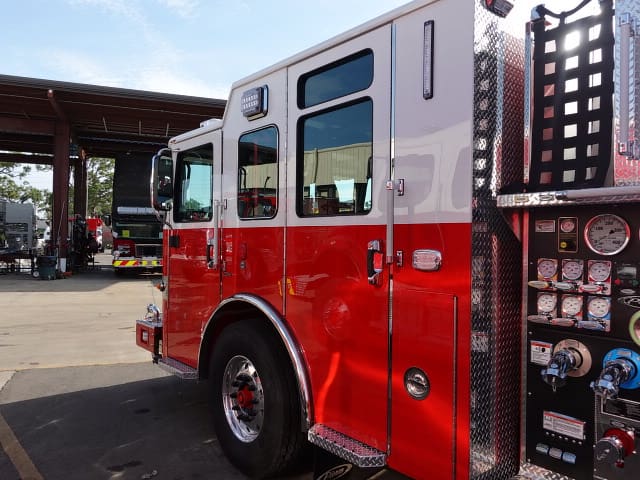

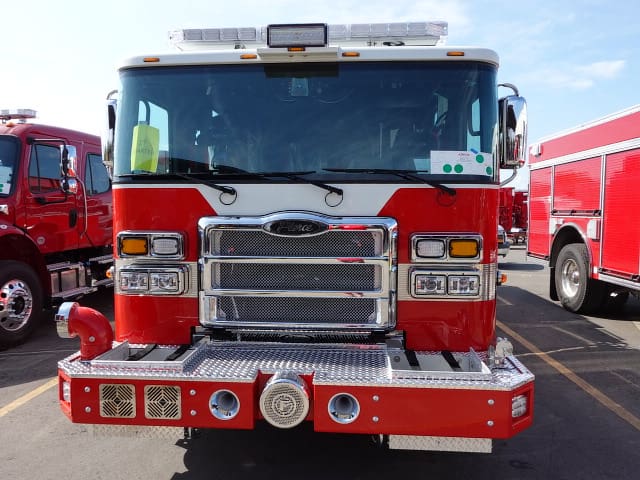

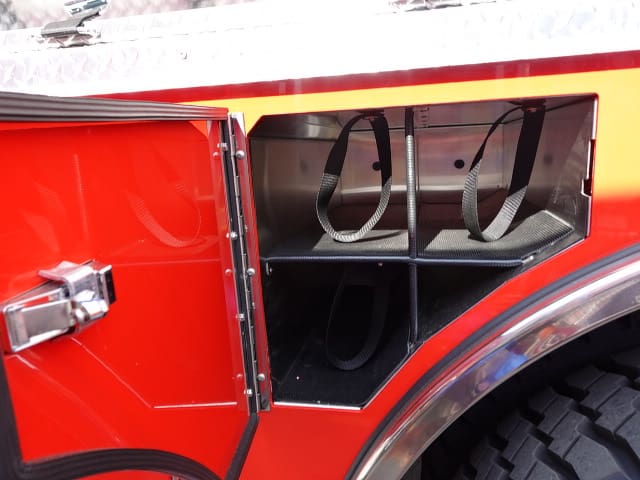

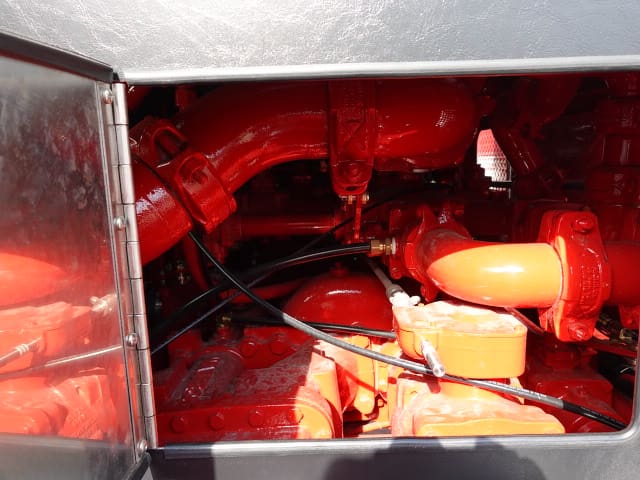

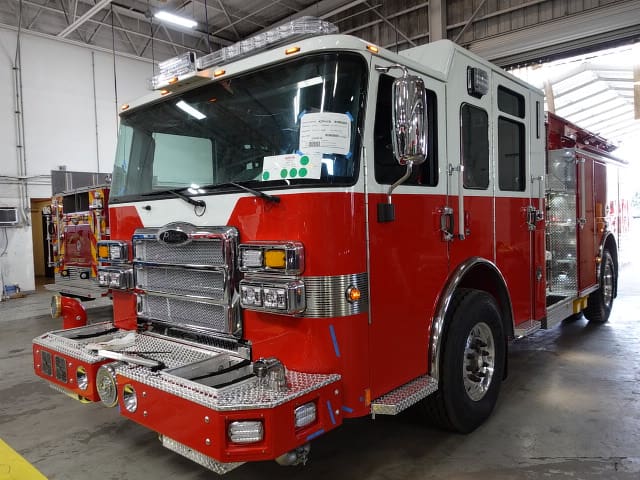

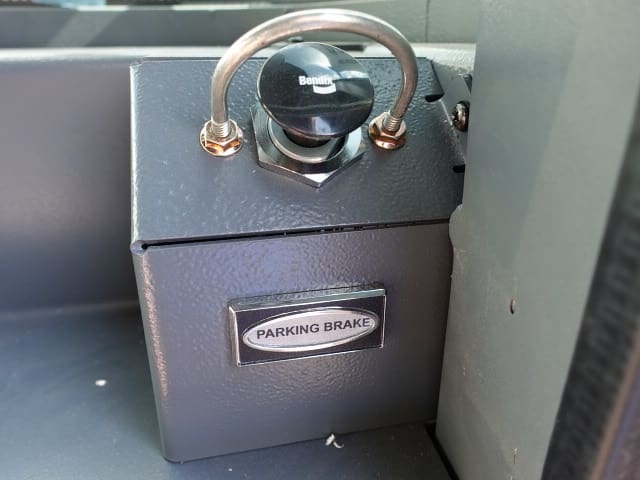

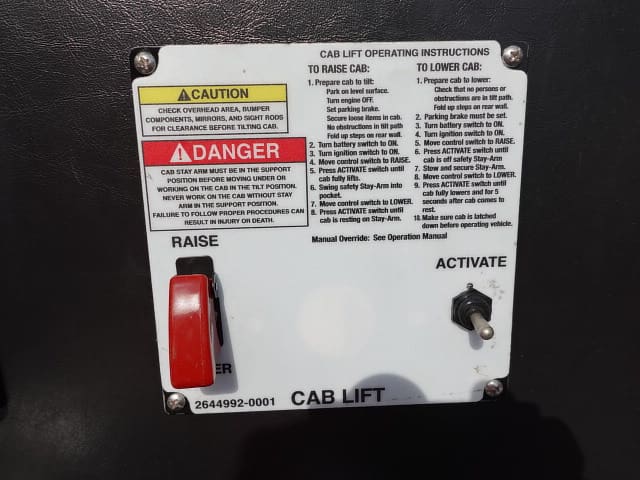

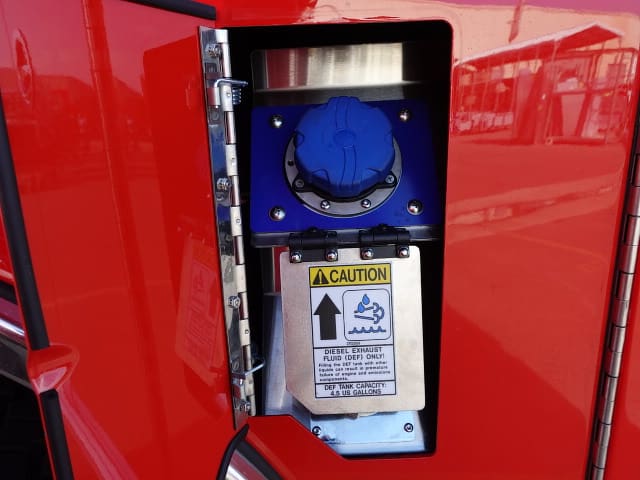

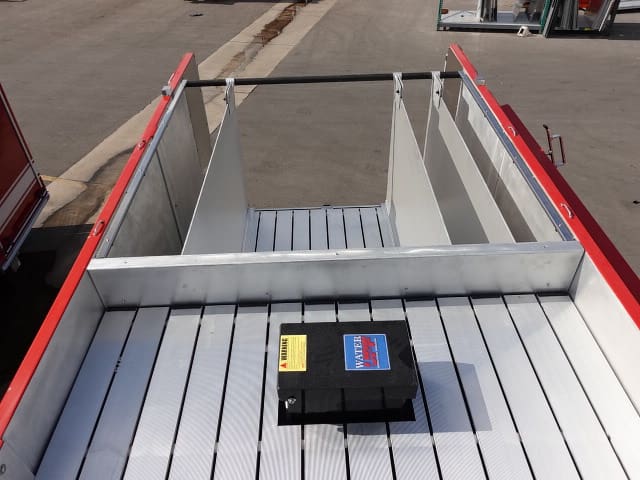

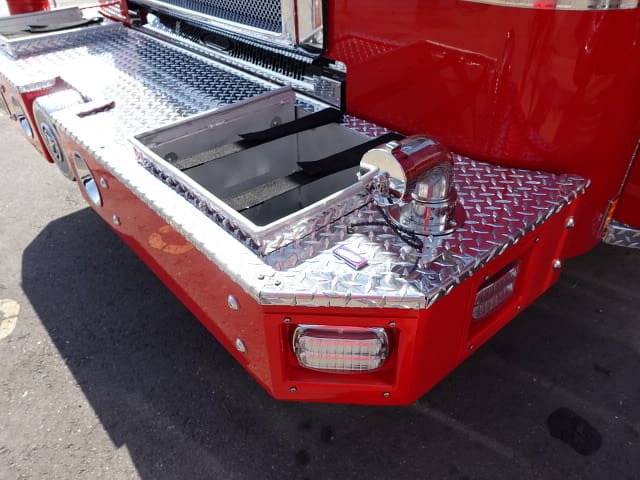

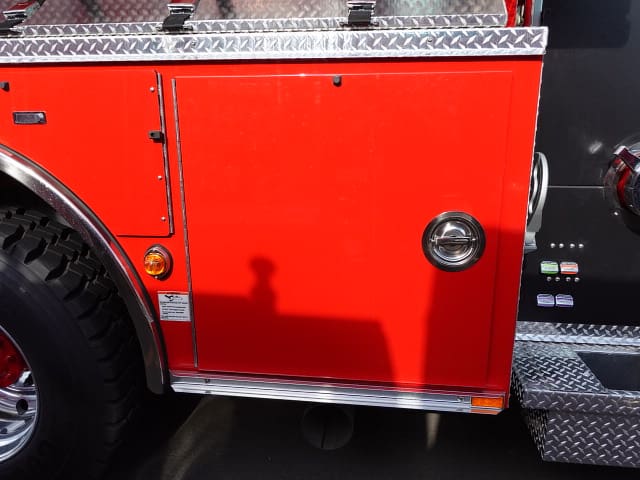

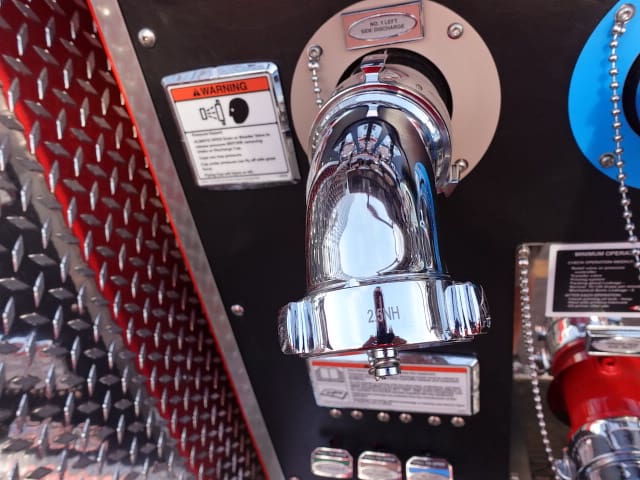

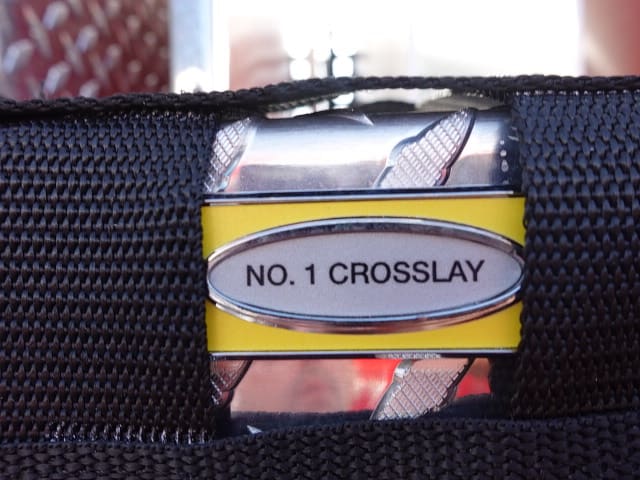

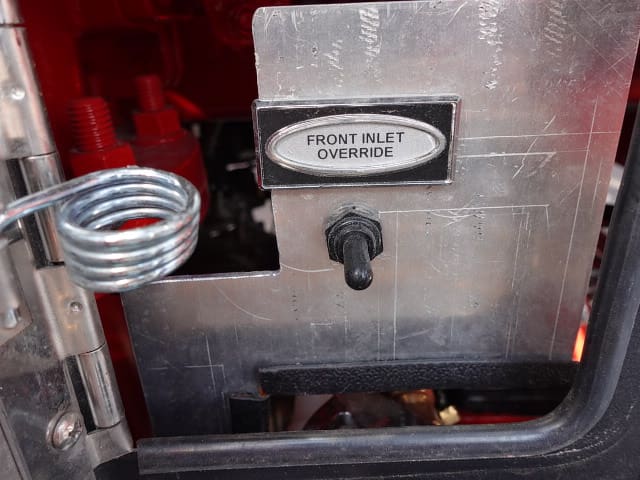

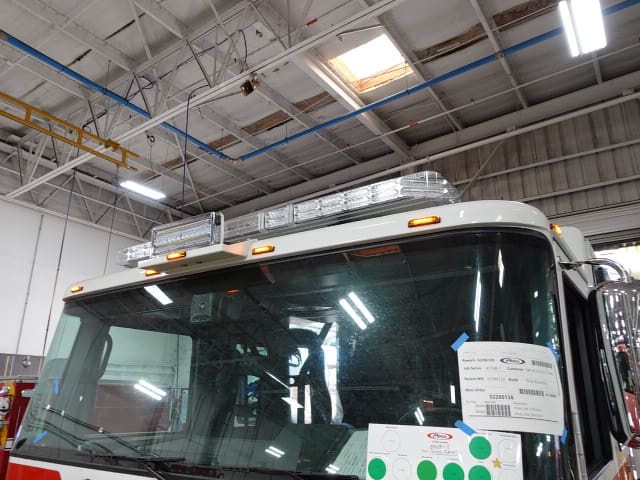

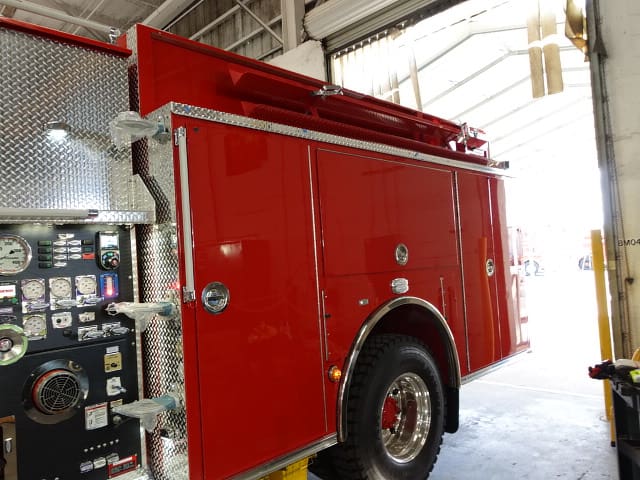

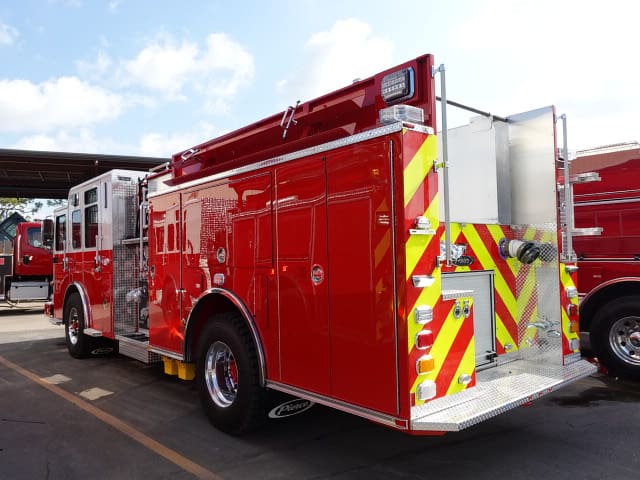

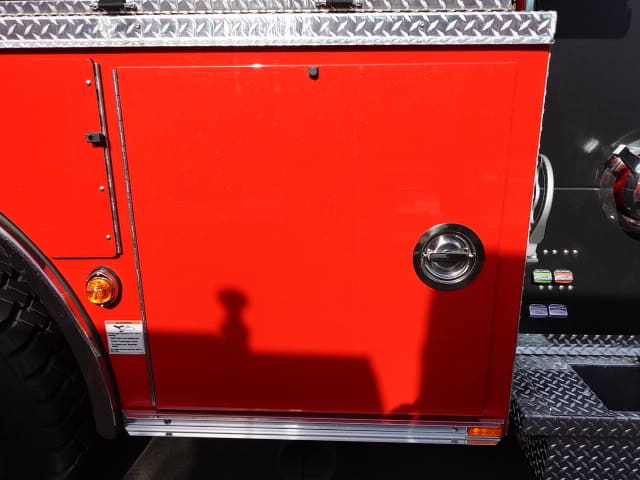

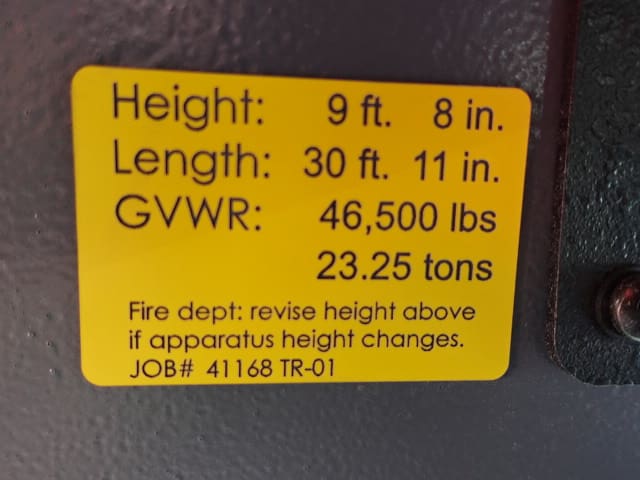

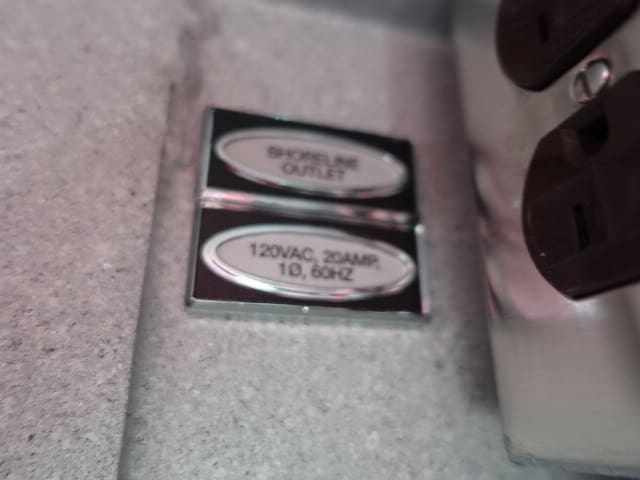

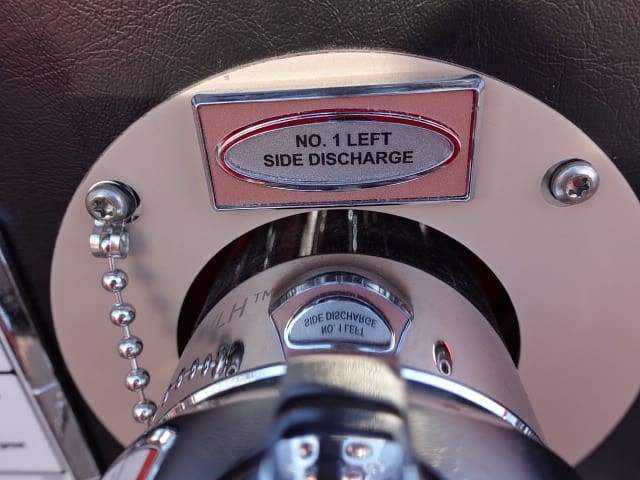

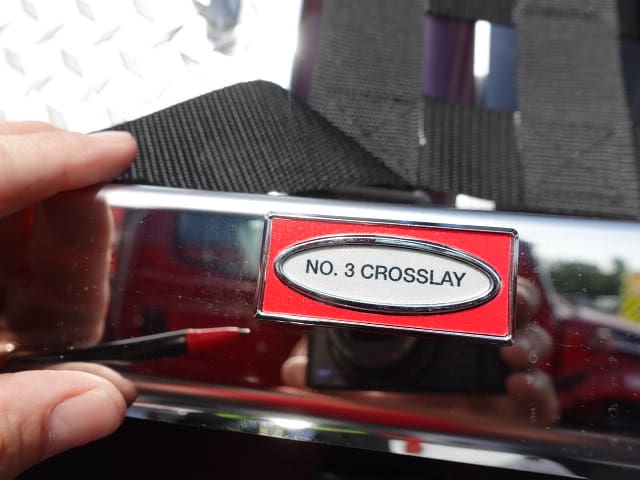

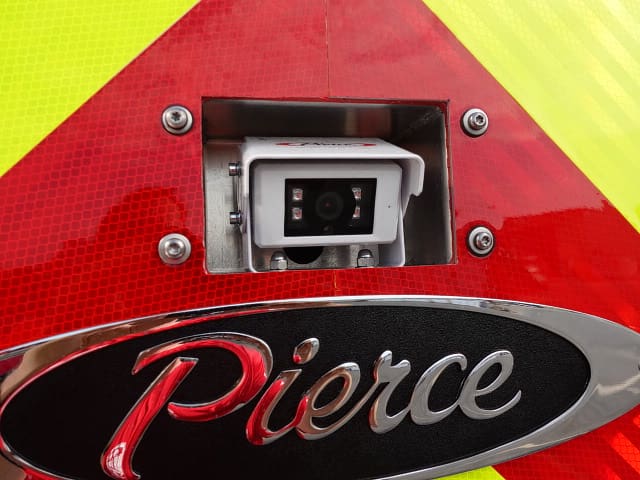

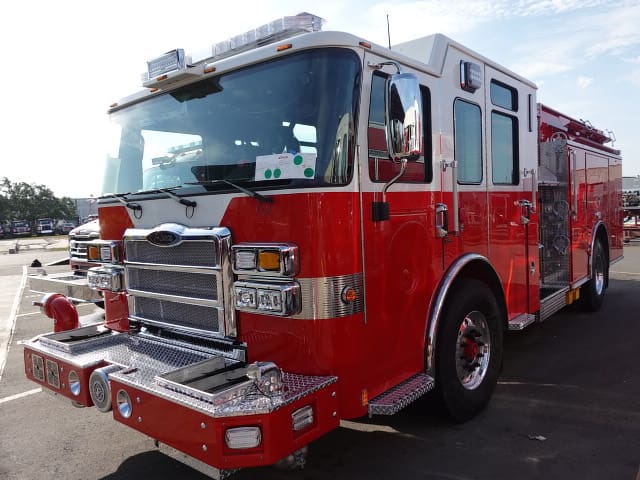

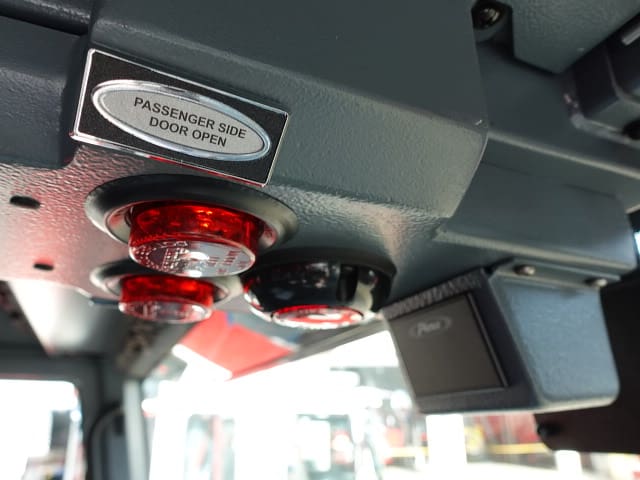

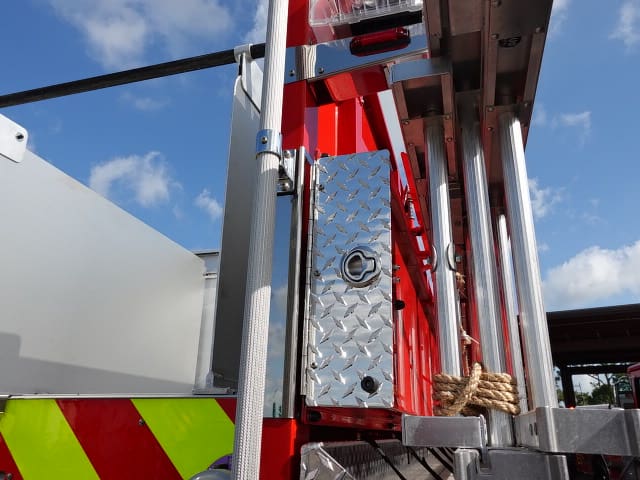

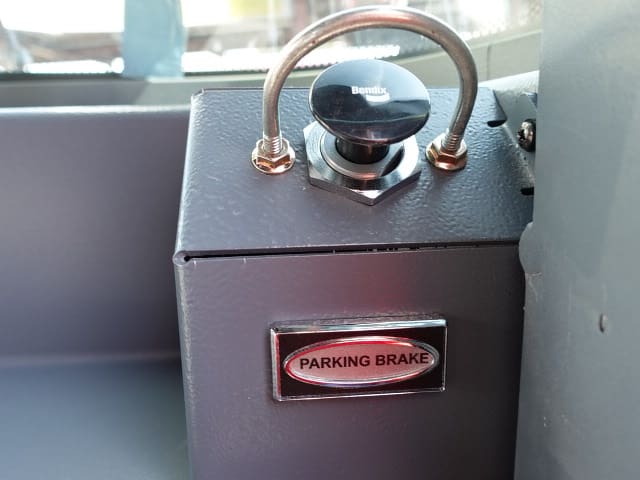

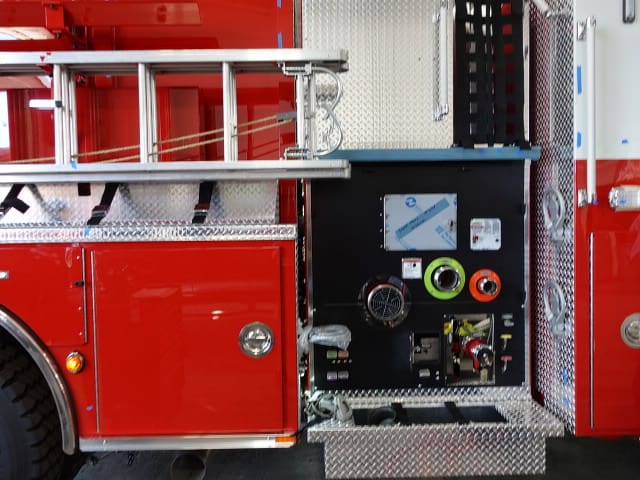

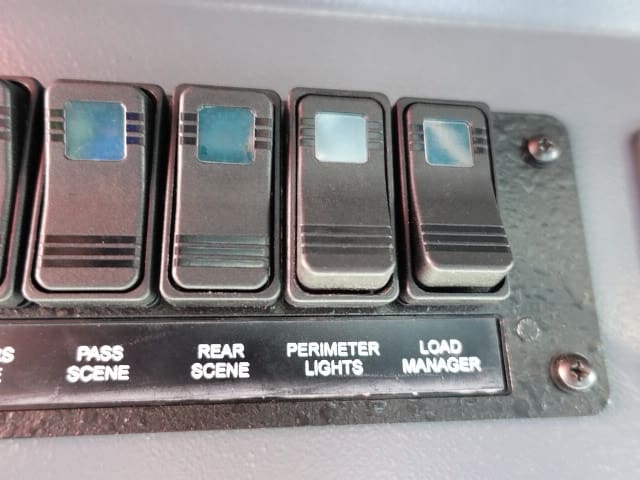

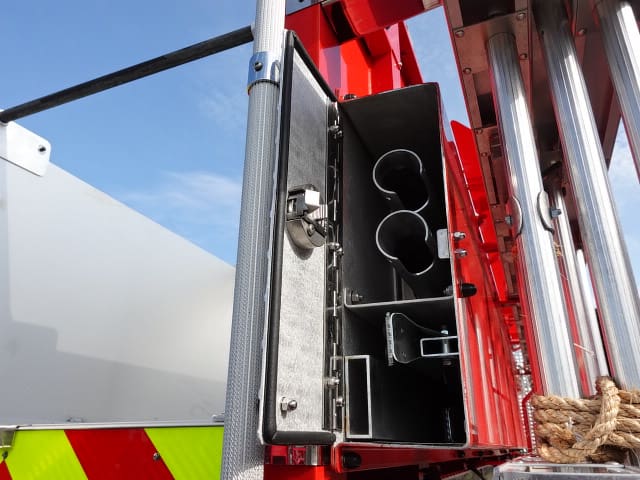

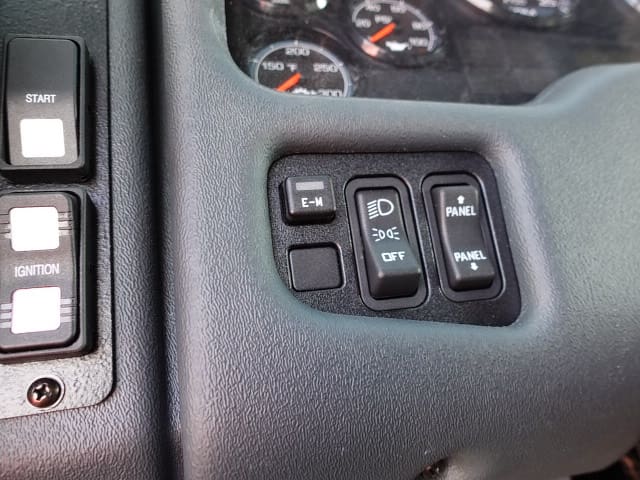

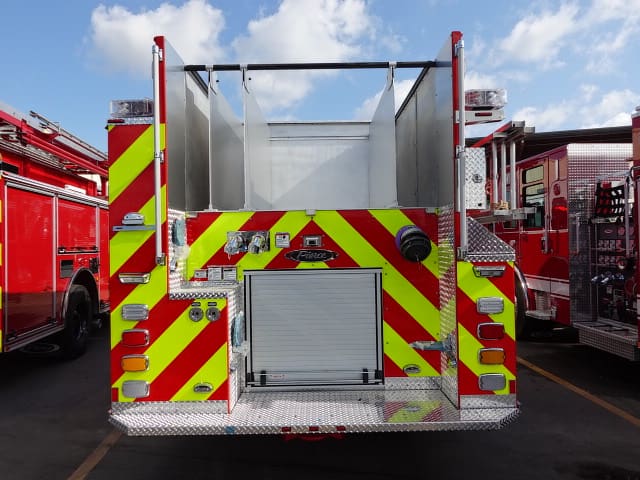

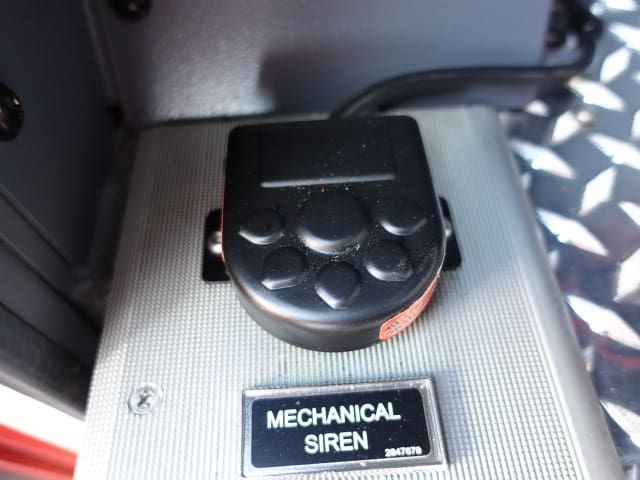

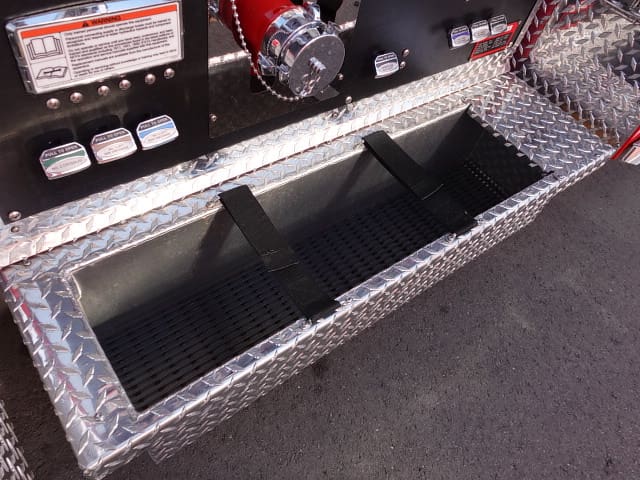

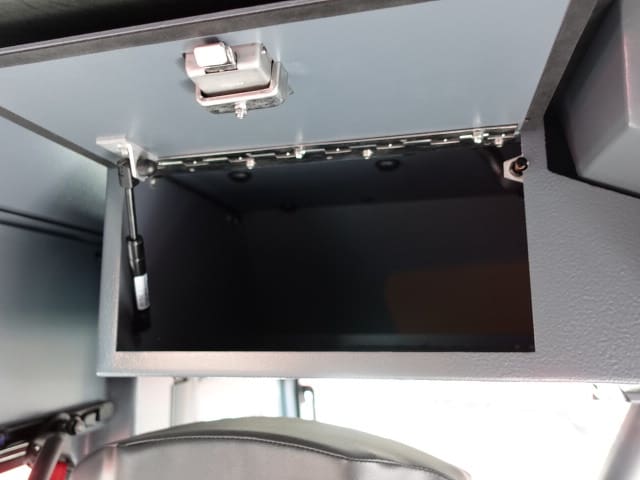

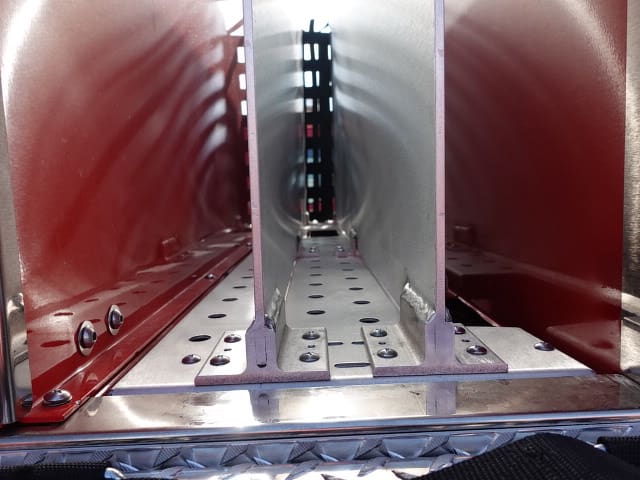

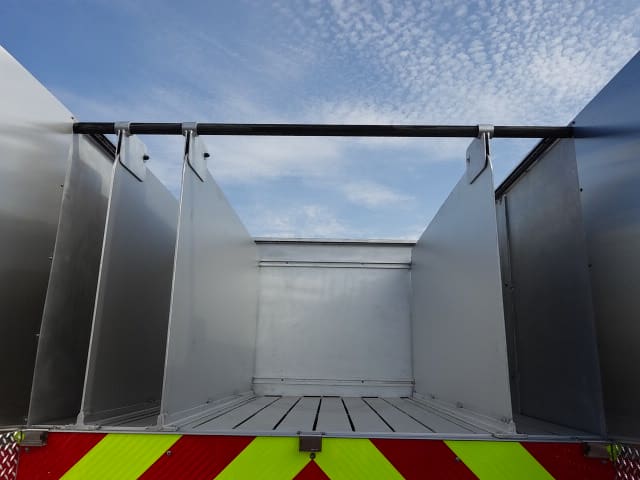

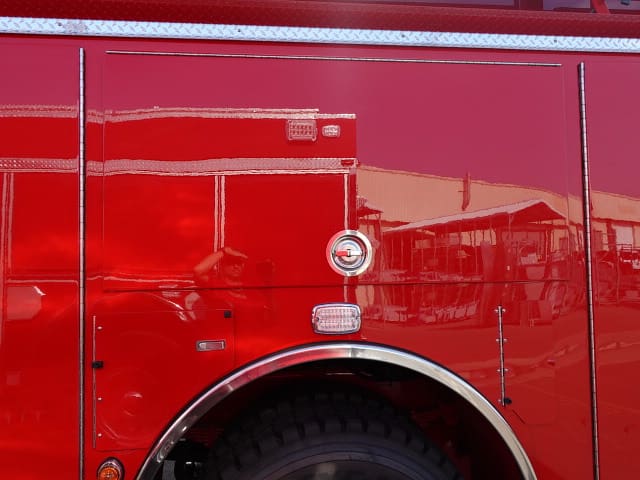

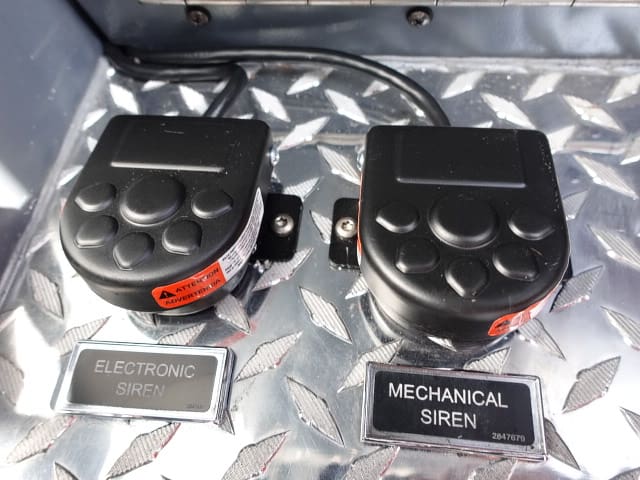

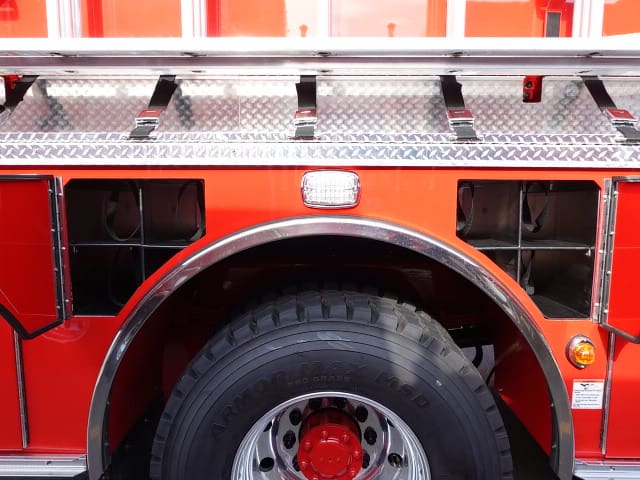

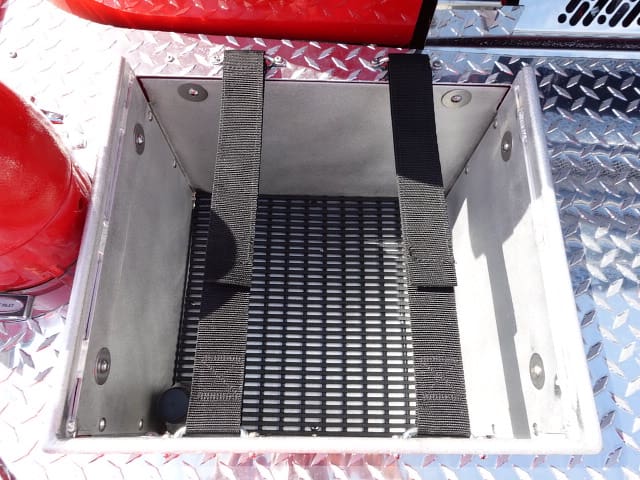

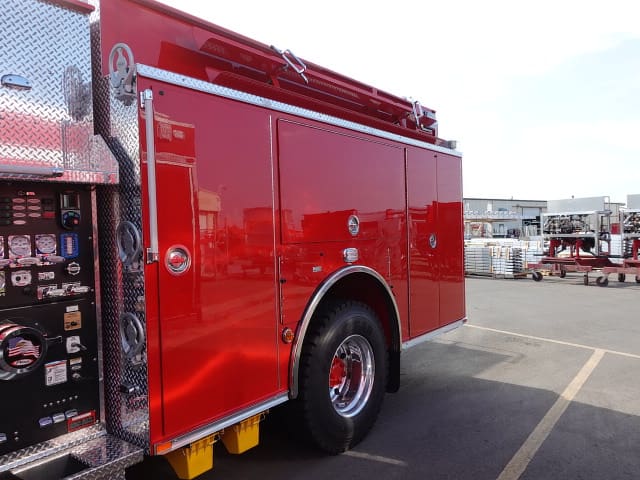

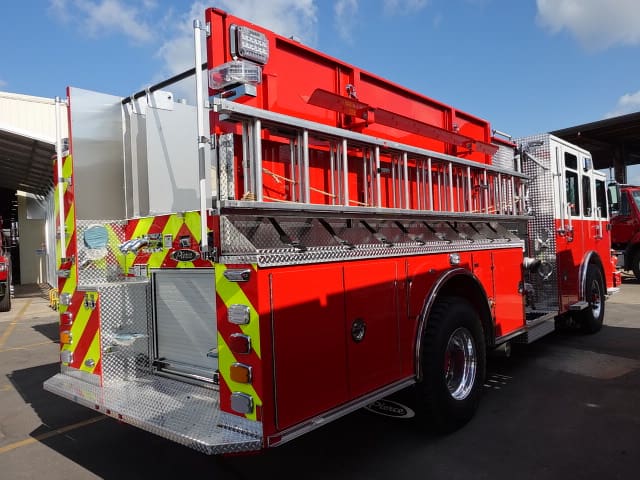

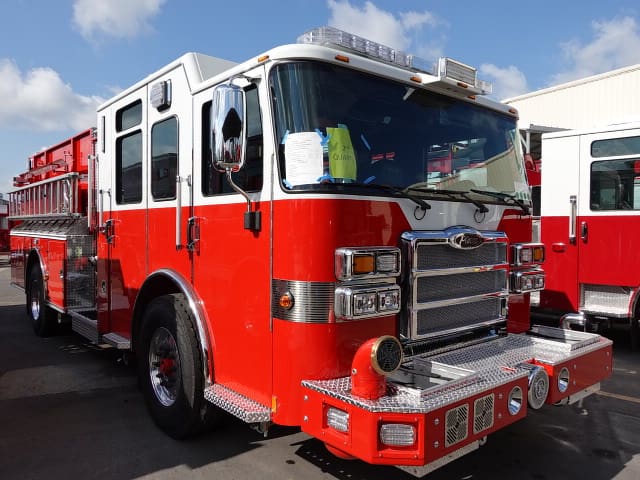

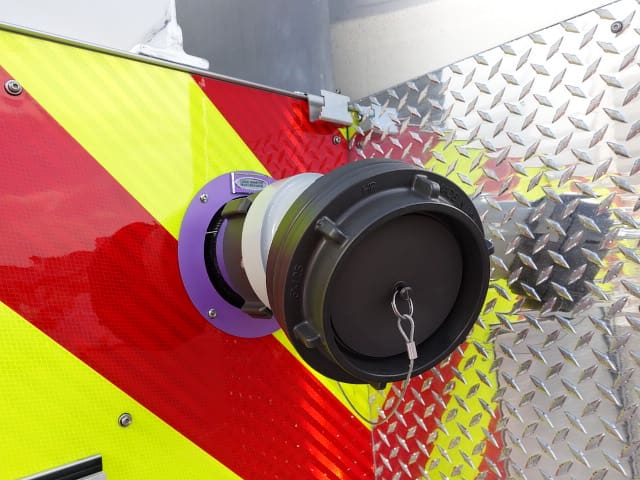

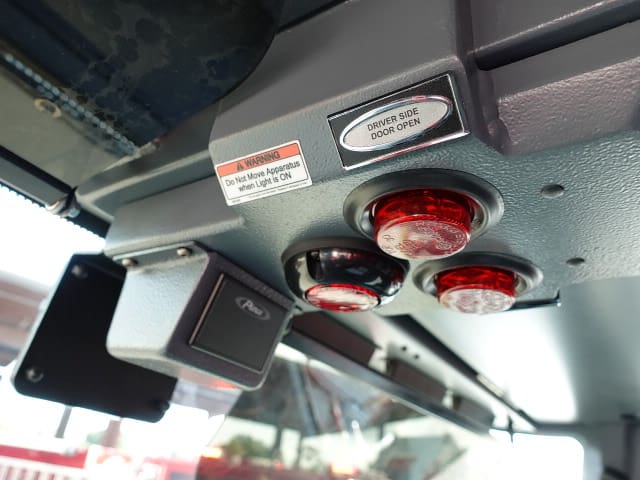

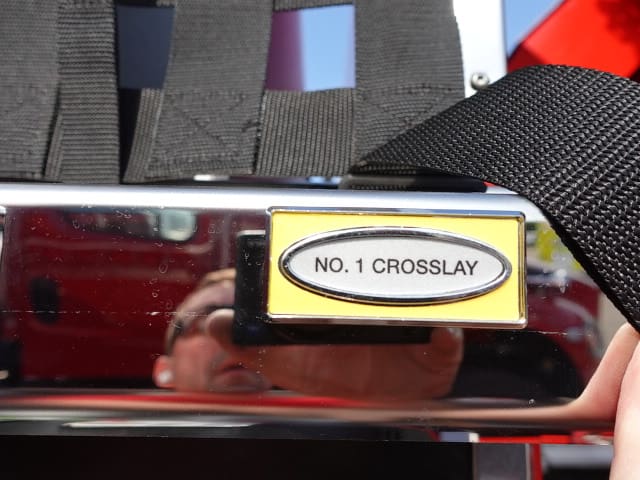

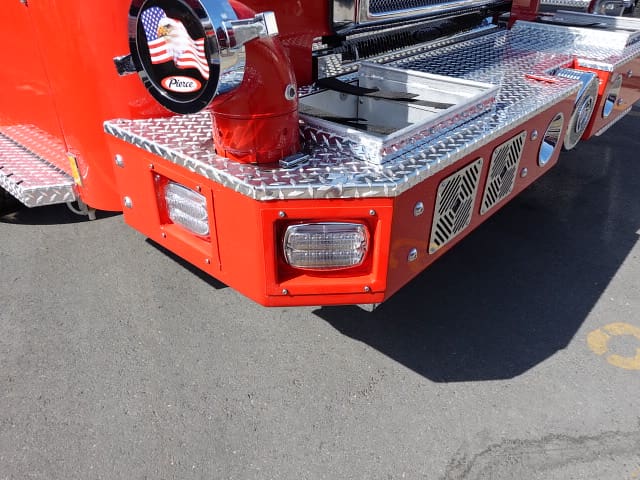

In this report, the apparatus completed test followed by release to final product evaluation where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.

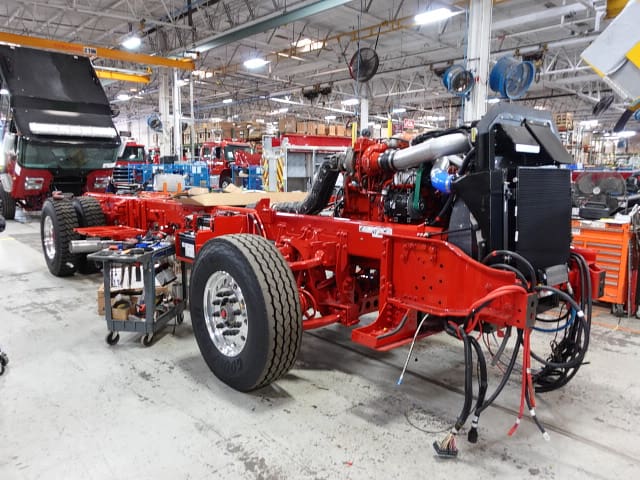

05-16-25

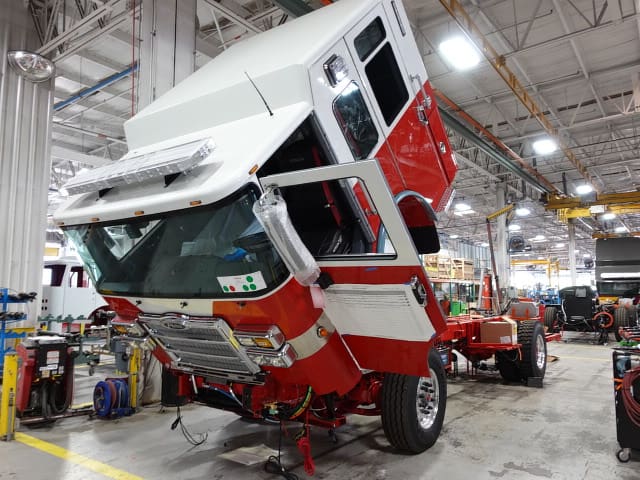

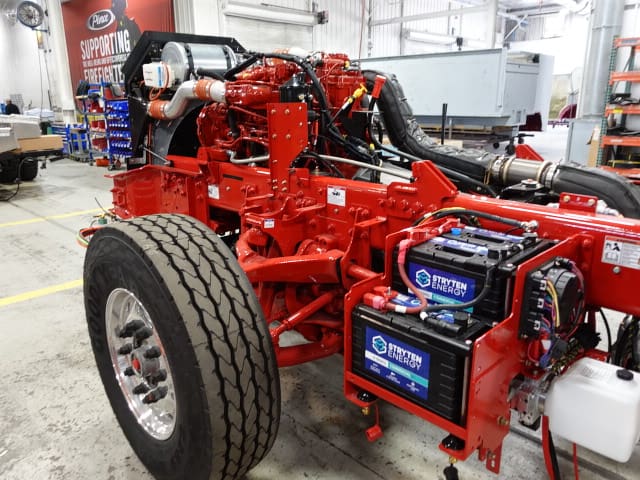

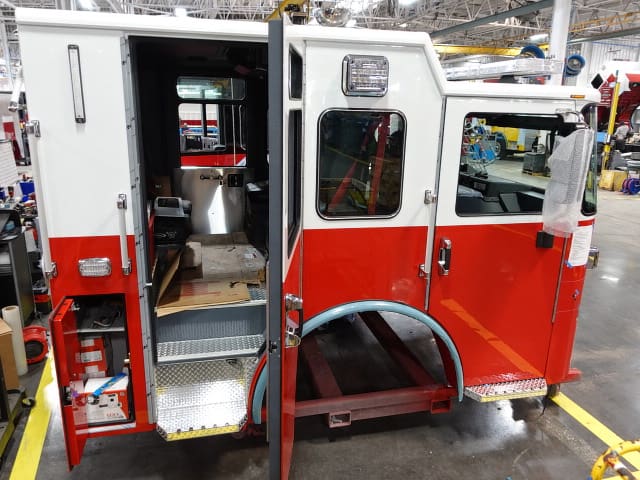

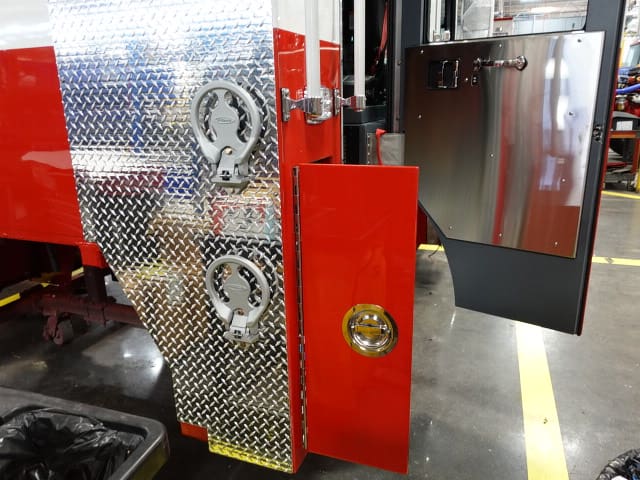

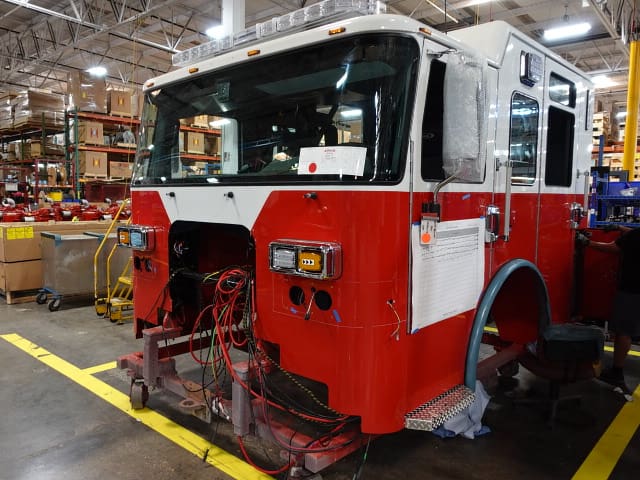

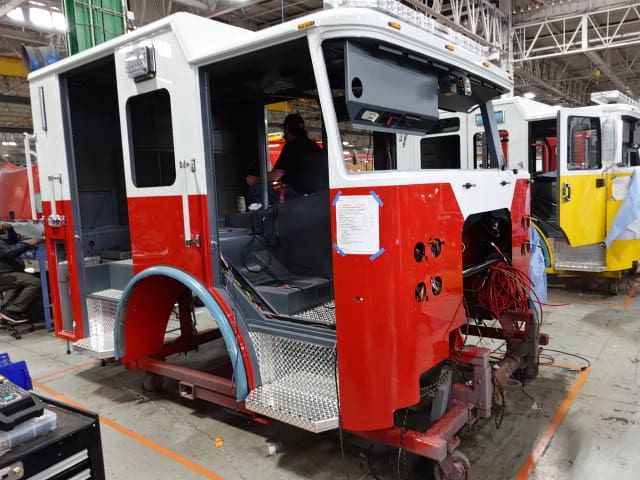

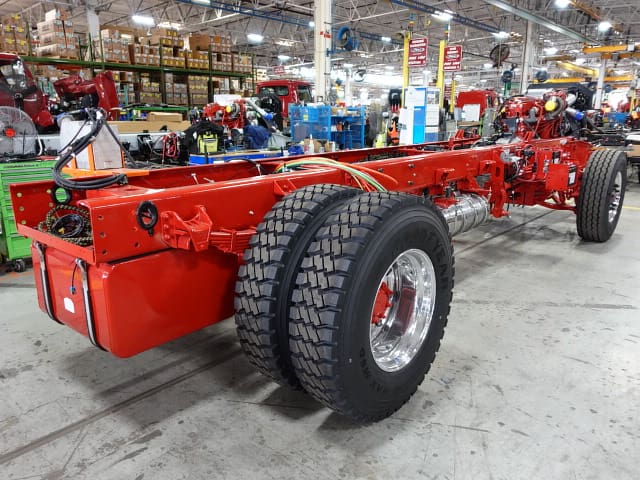

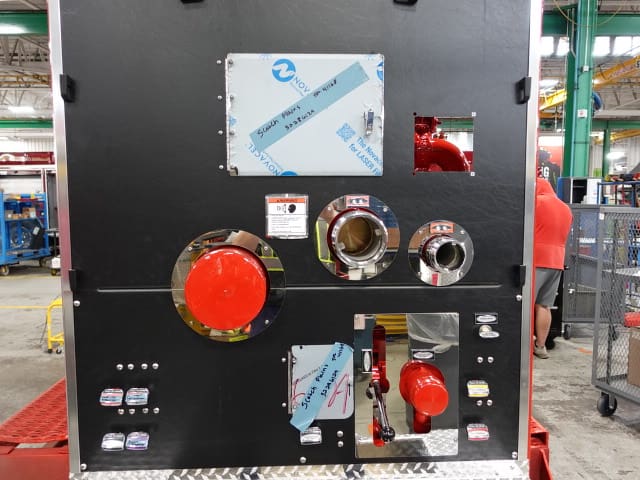

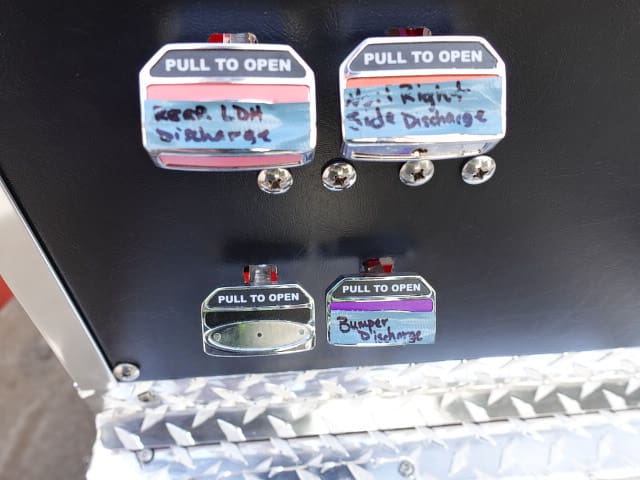

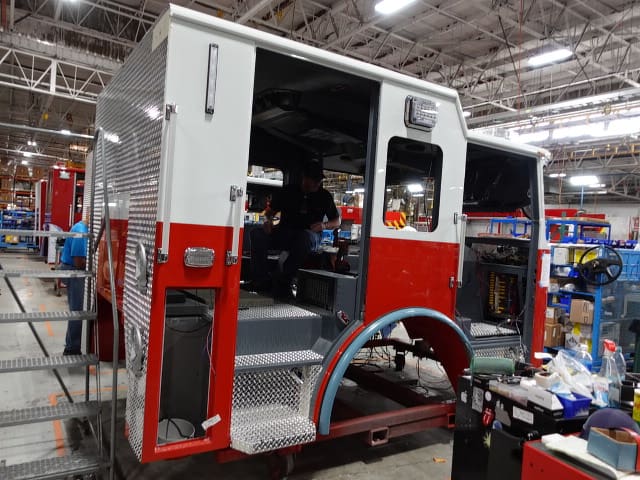

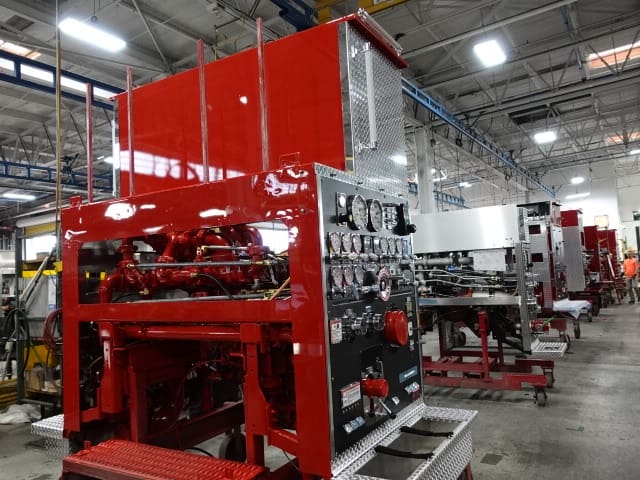

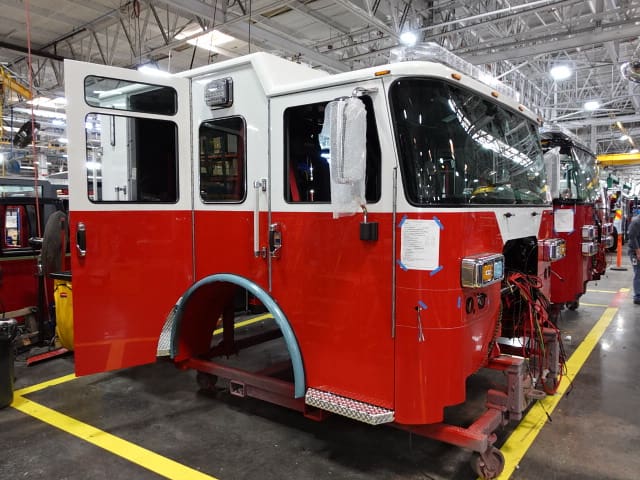

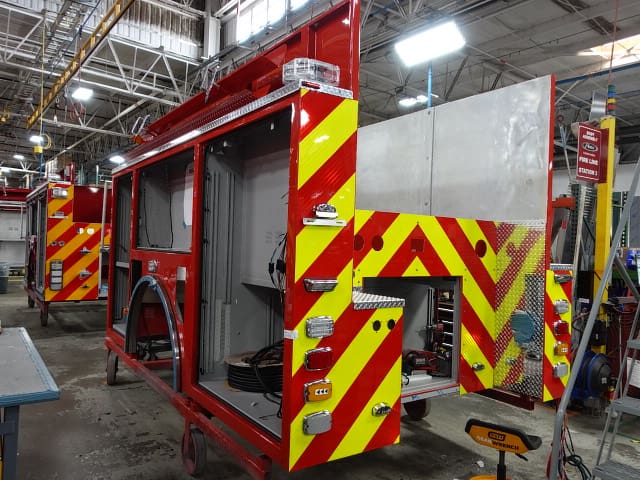

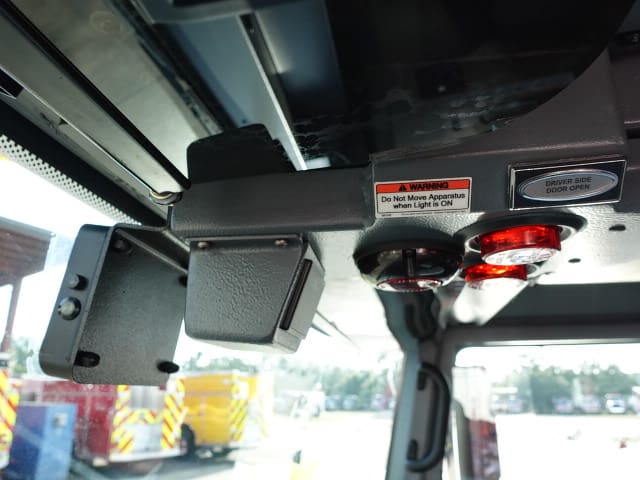

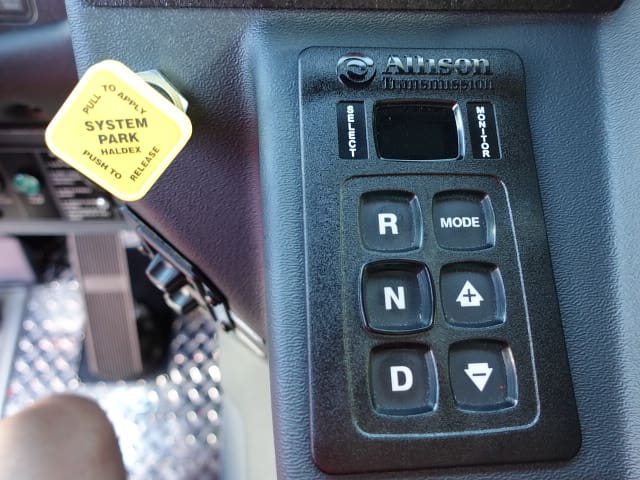

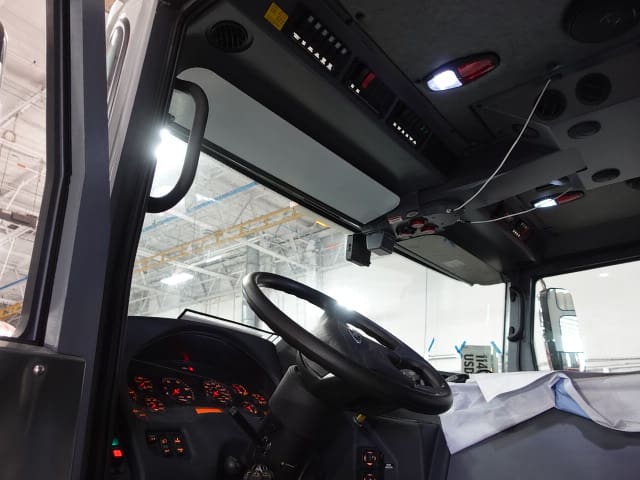

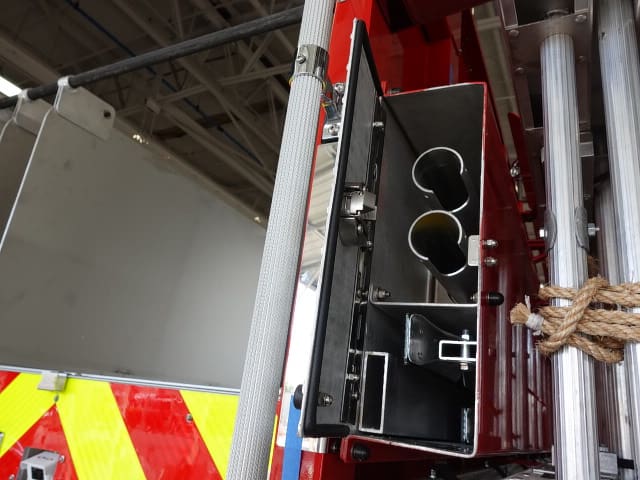

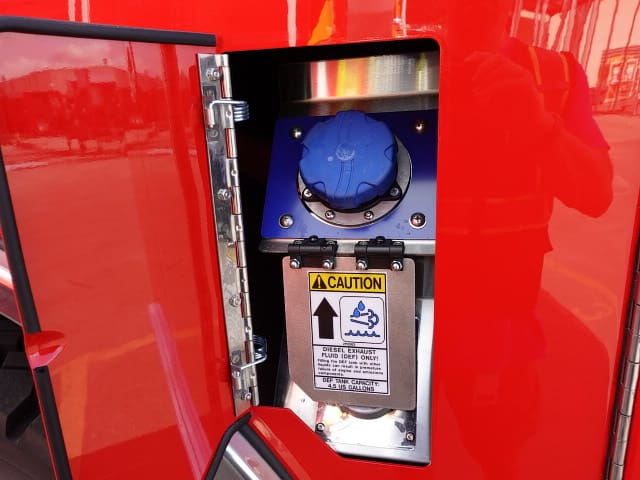

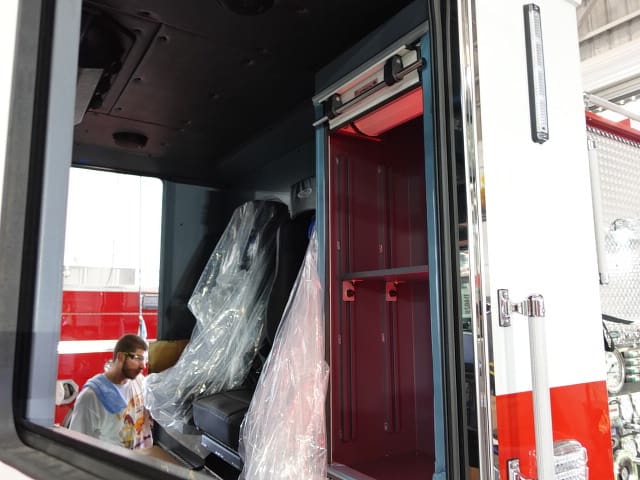

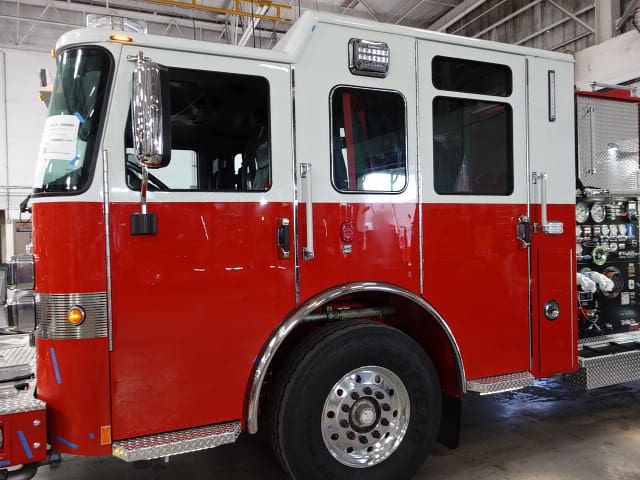

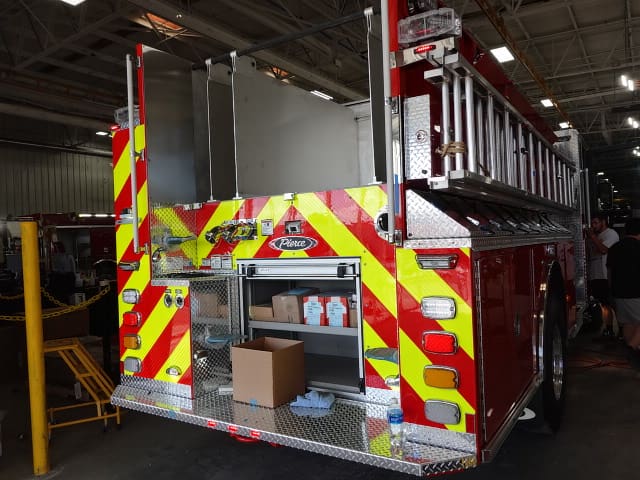

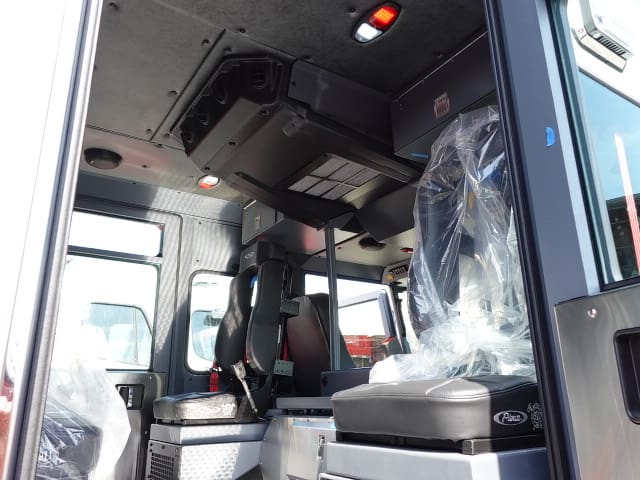

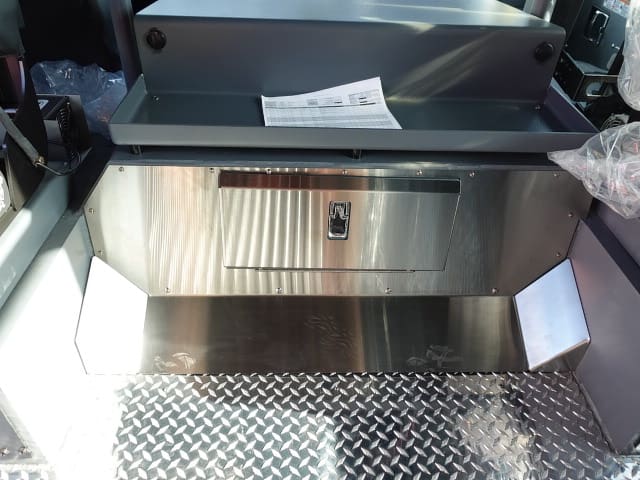

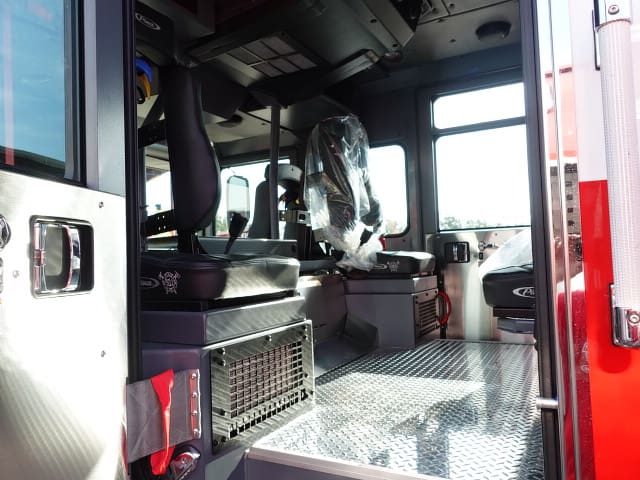

In this report, the apparatus completed initial assembly and began final assembly.

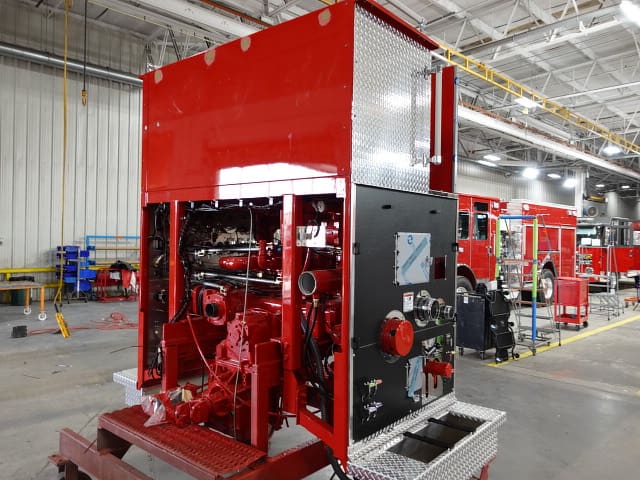

05-02-25

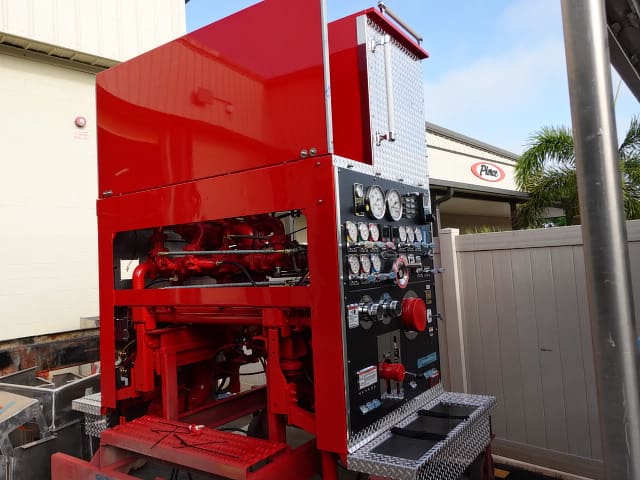

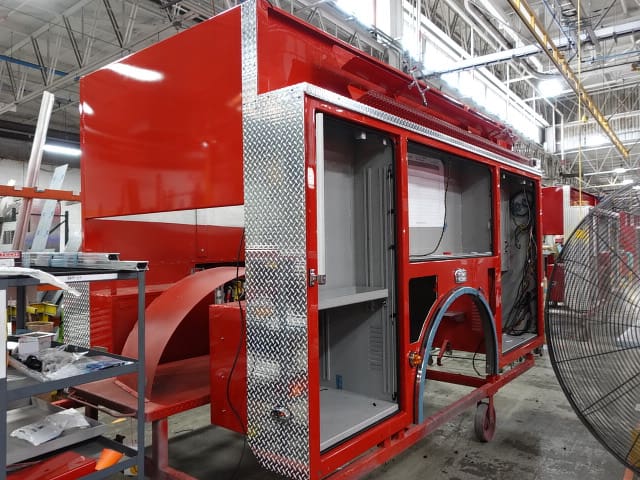

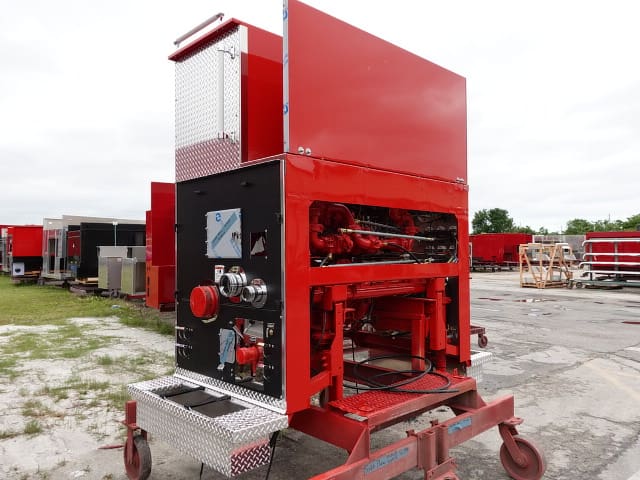

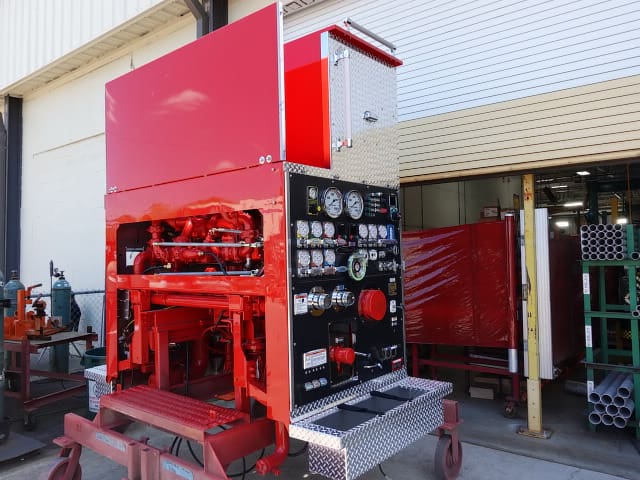

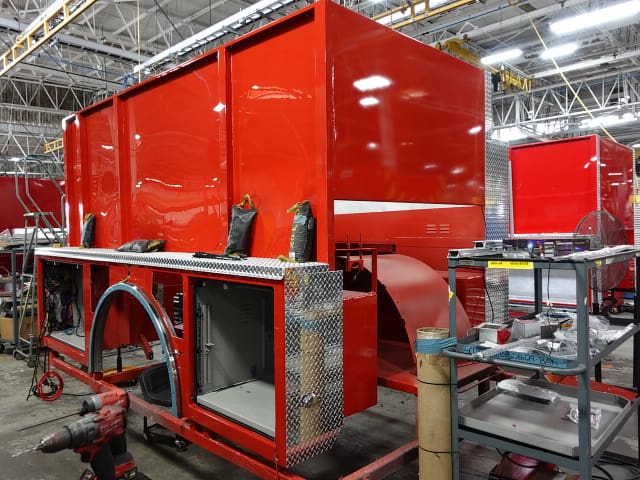

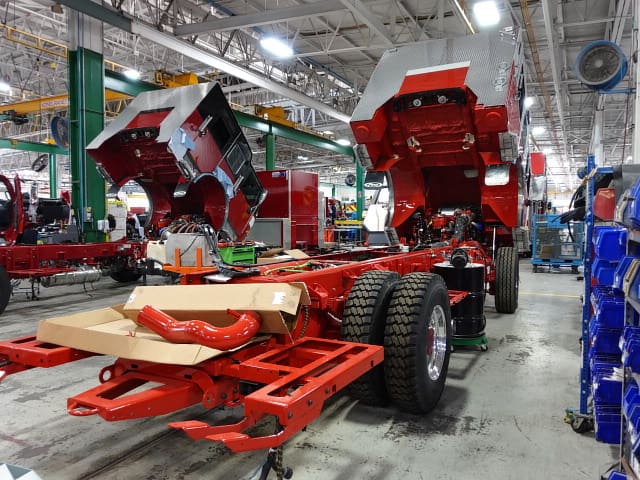

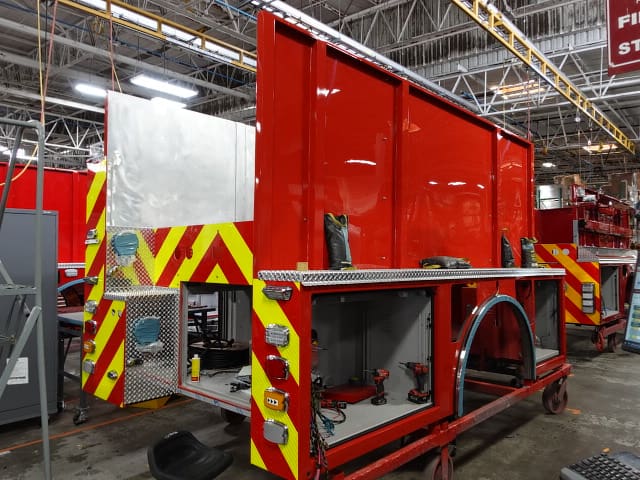

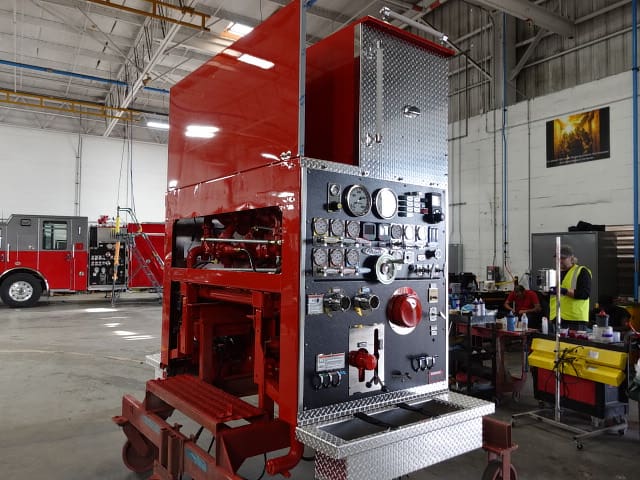

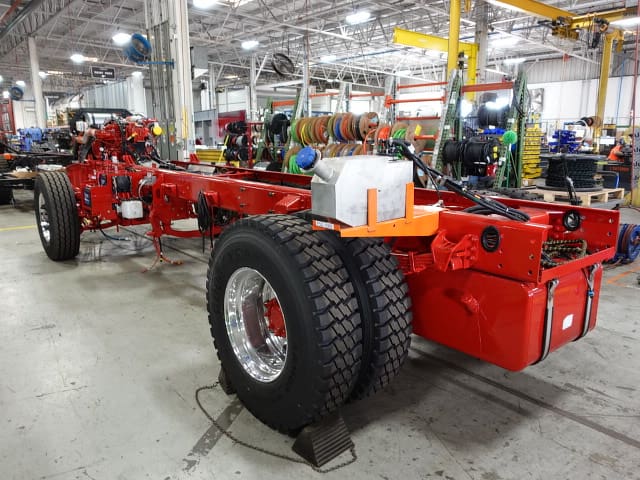

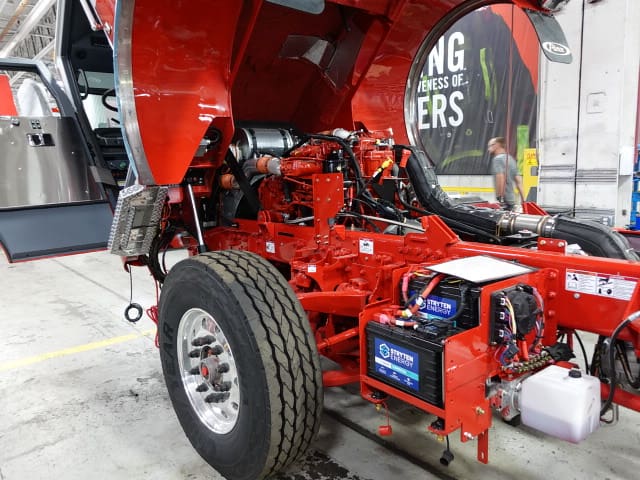

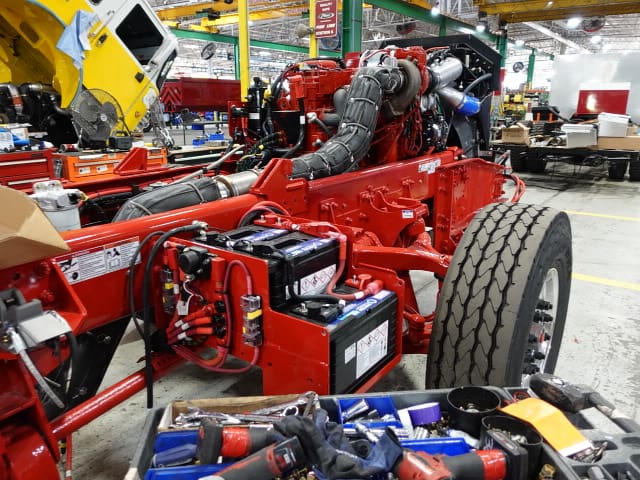

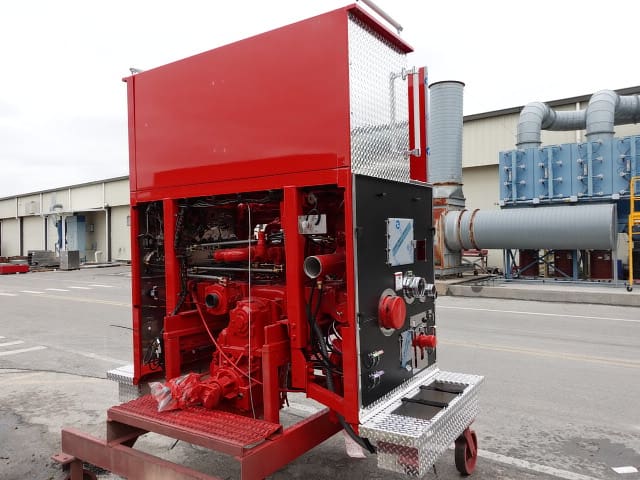

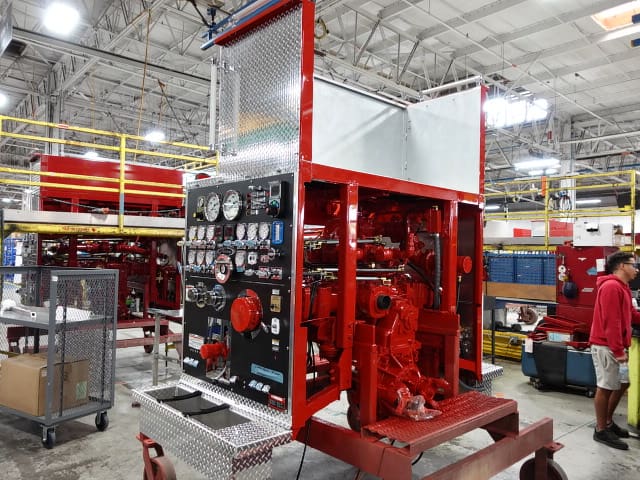

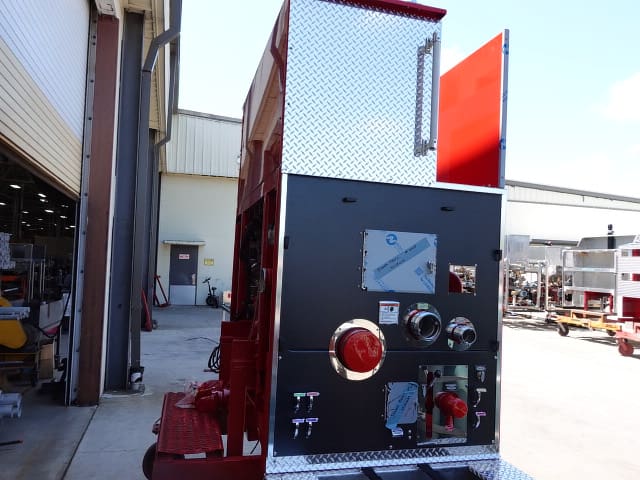

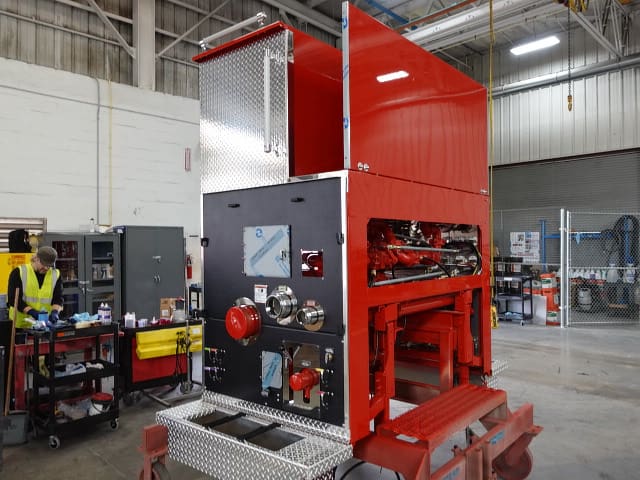

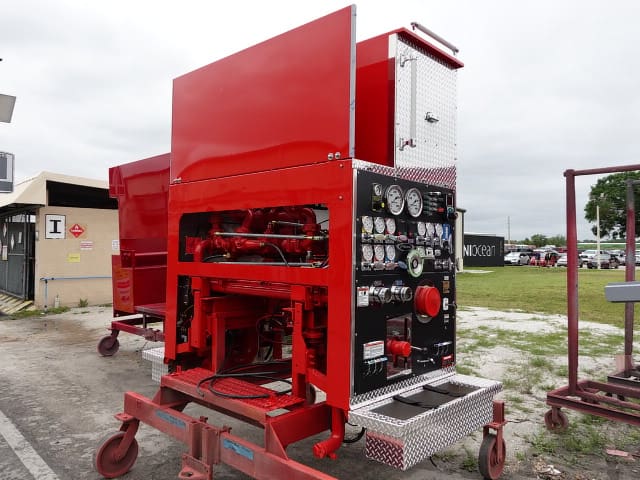

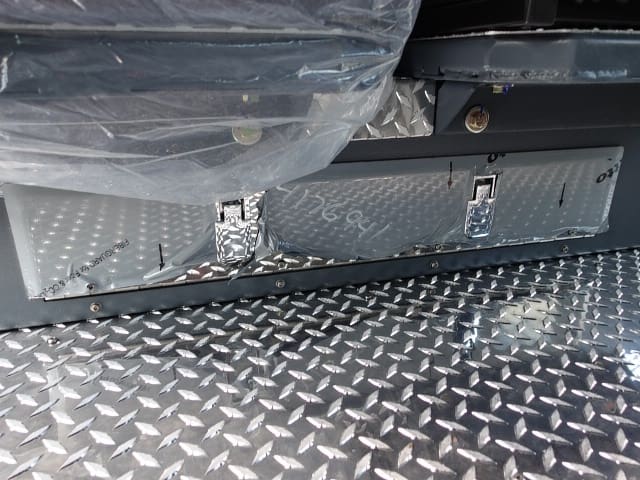

In this report, the pump house and body were merged with the chassis while assembly continued.
04-25-25

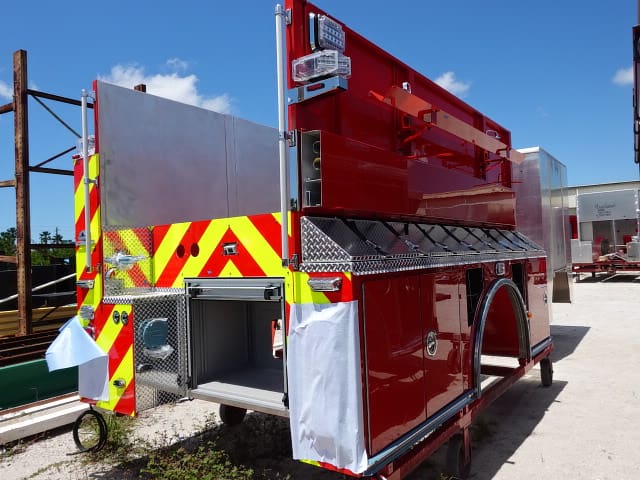

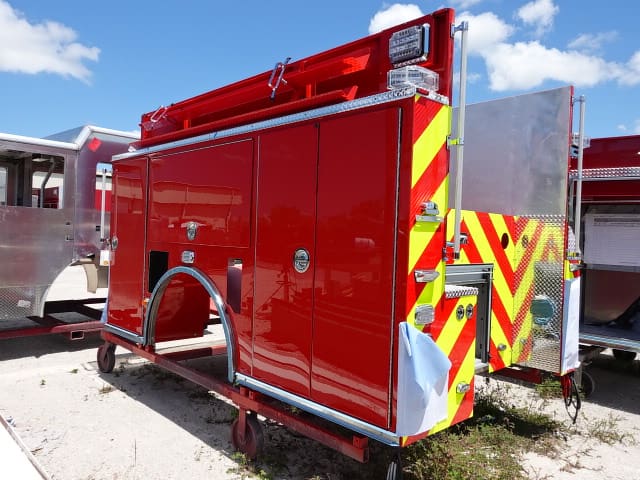

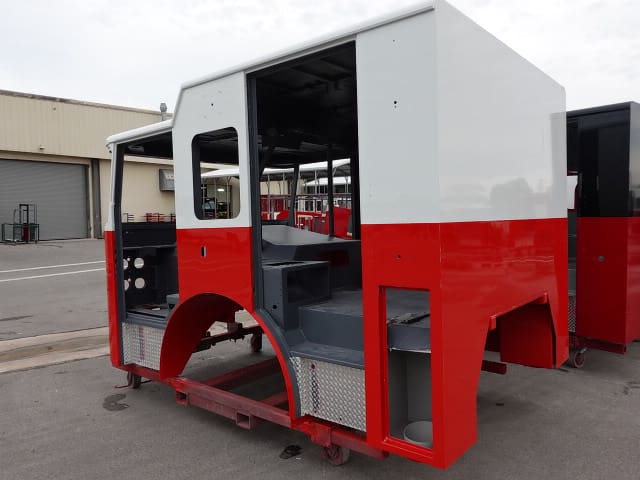

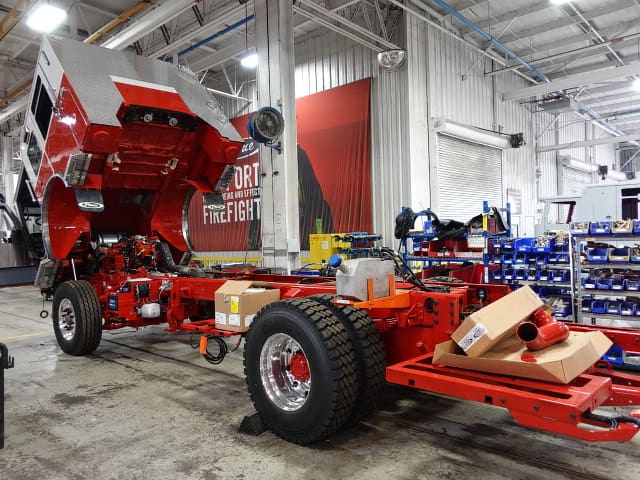

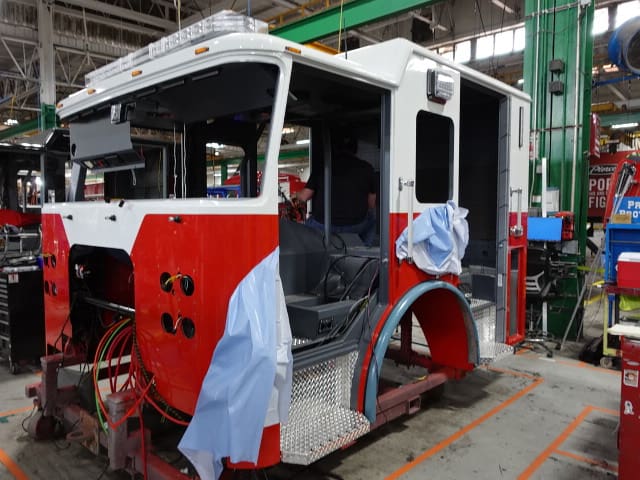

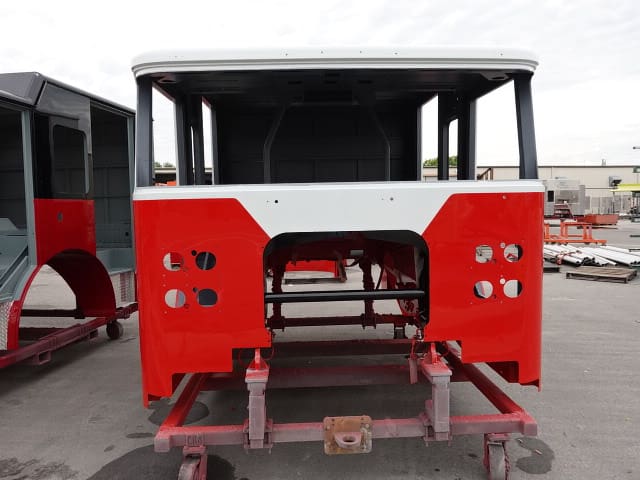

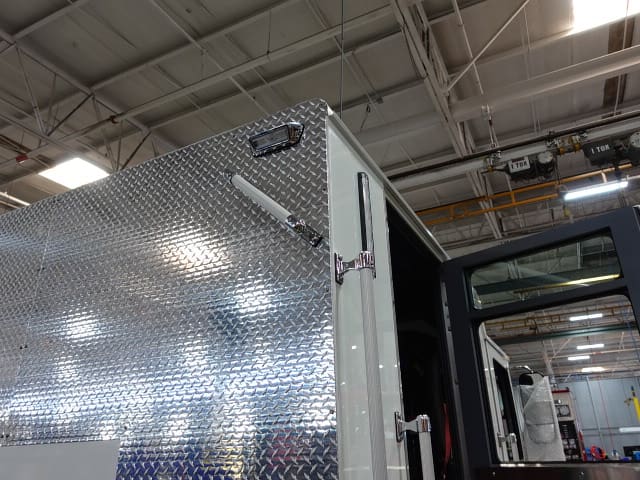

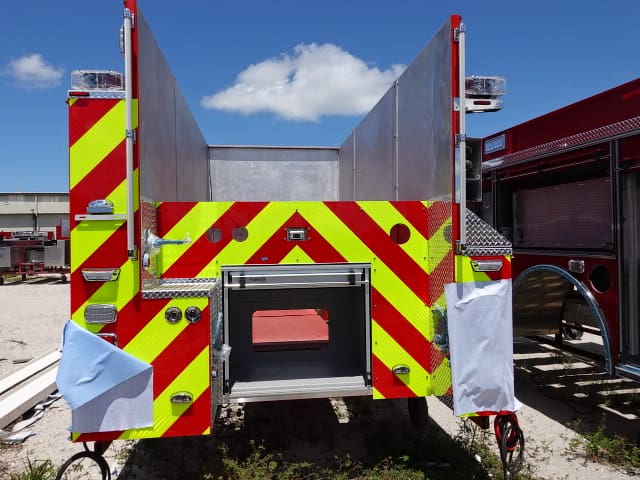

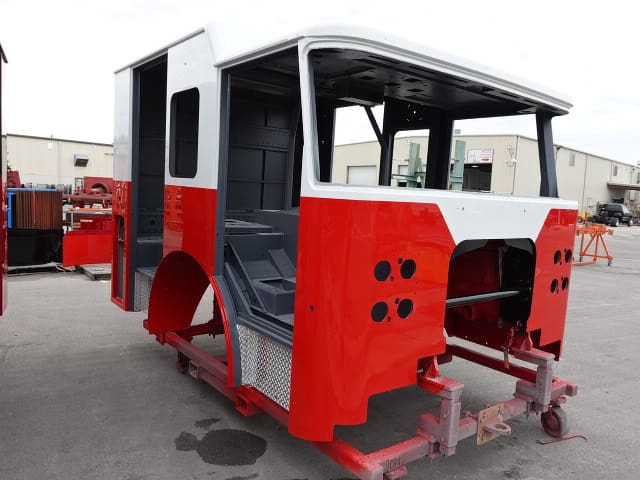

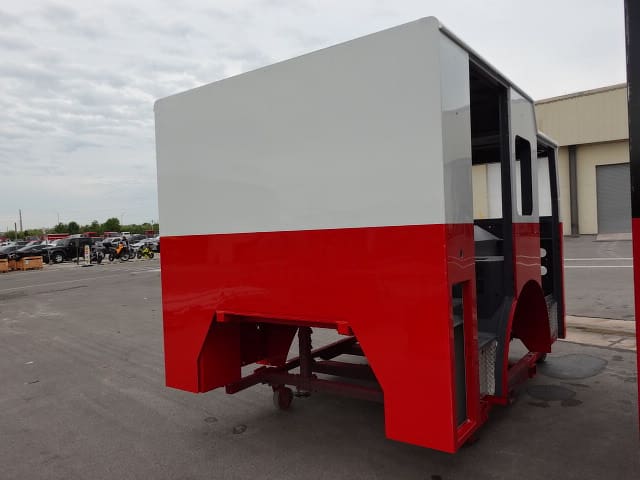

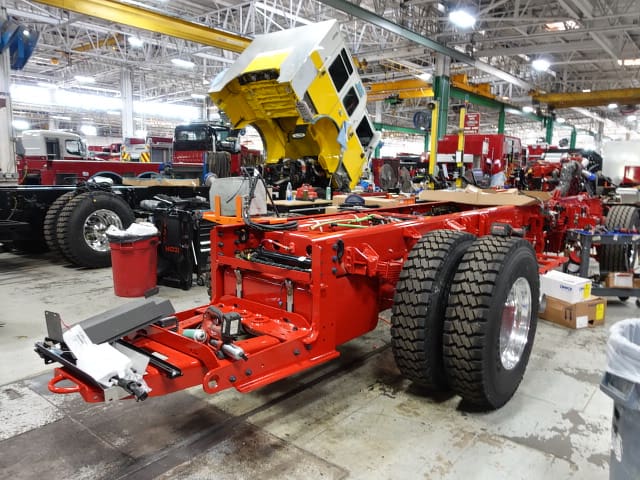

In this report, the cab completed initial assembly and was merged with the frame, the pump house continued initial assembly, and the body remained staged (no photos).
04-18-25

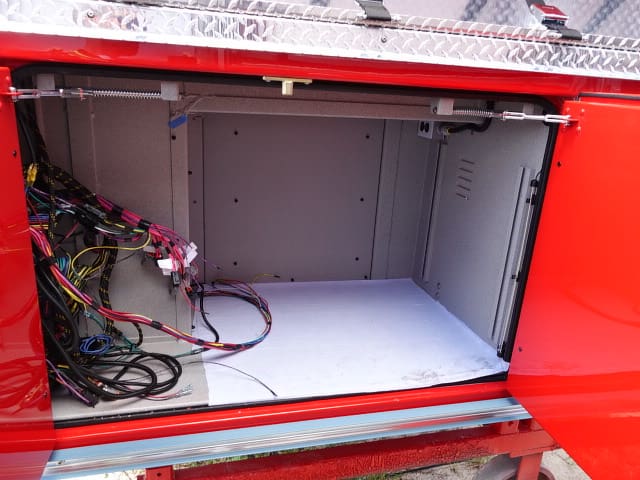

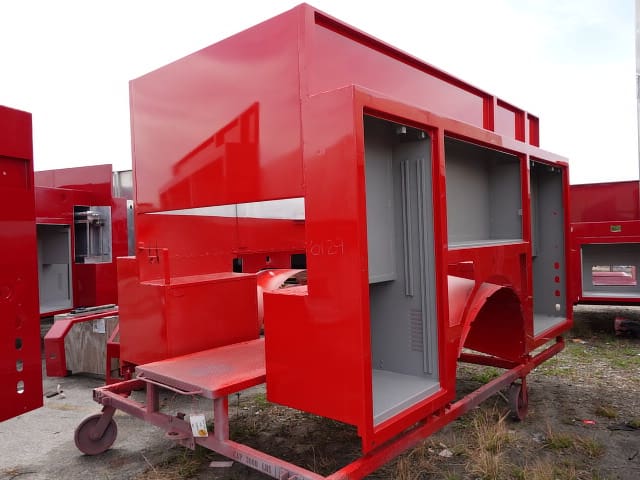

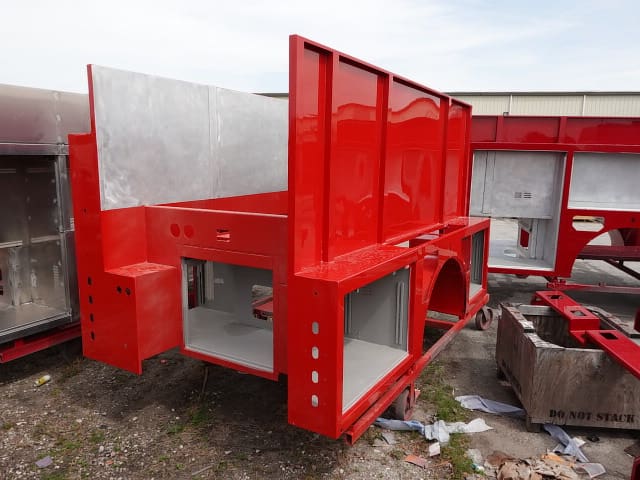

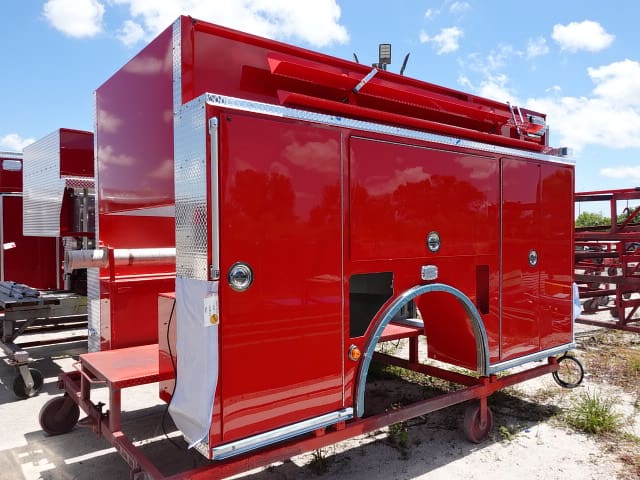

In this report, the cab continued initial assembly, the frame build continued, the pump house continued initial assembly, and the body completed initial assembly.
04-11-25
In this report, the cab began initial assembly, the frame build continued, the pump house was staged, and the body began initial assembly.

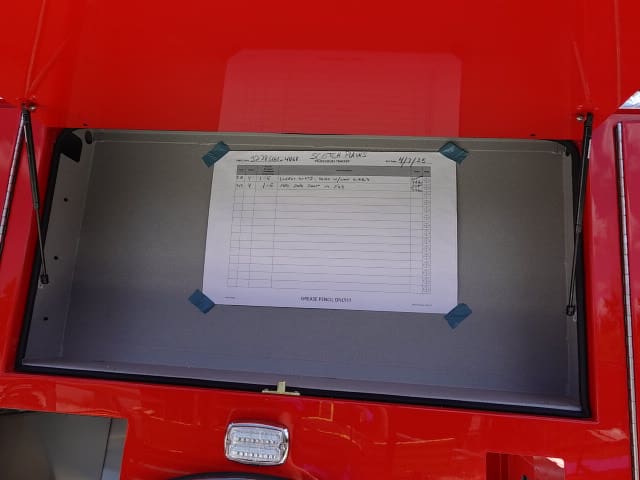

04-04-25

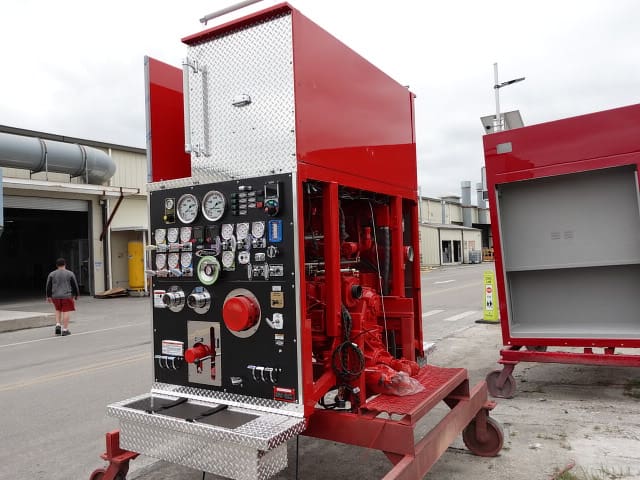

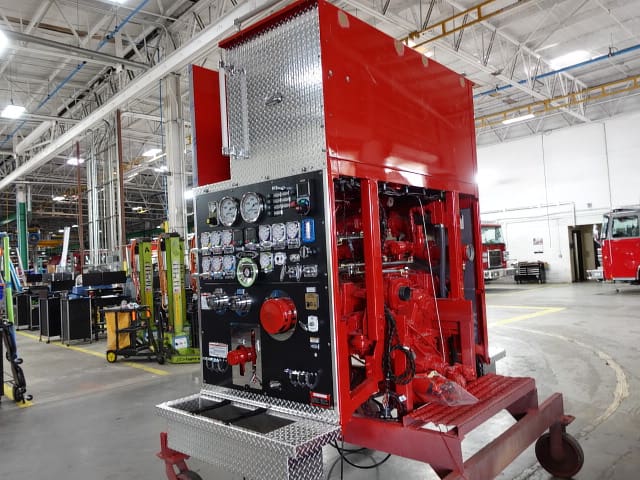

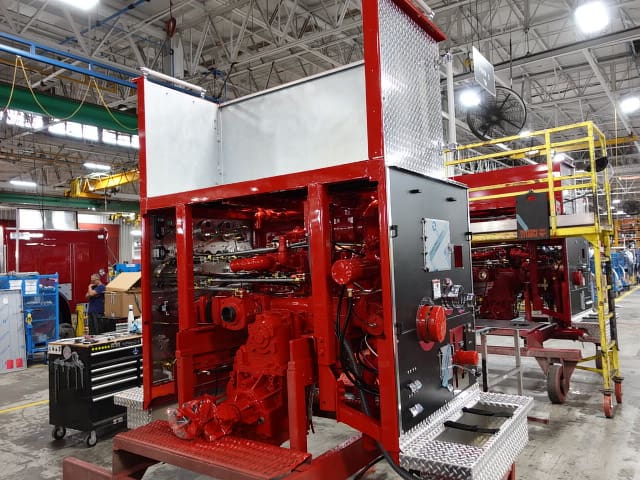

In this report, the cab, frame, and body were staged (no photos) while the pump house completed initial assembly.
03-28-25

In this report, the cab was fabricated and painted, the frame remained staged (no photos), the pump house began initial assembly, and the body was fabricated and painted.

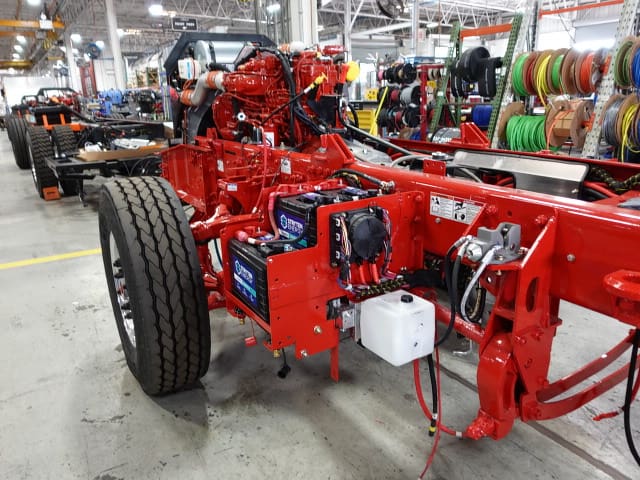

03-21-25

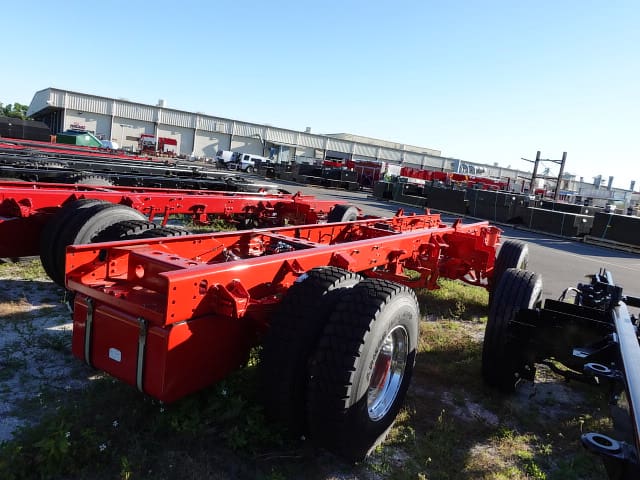

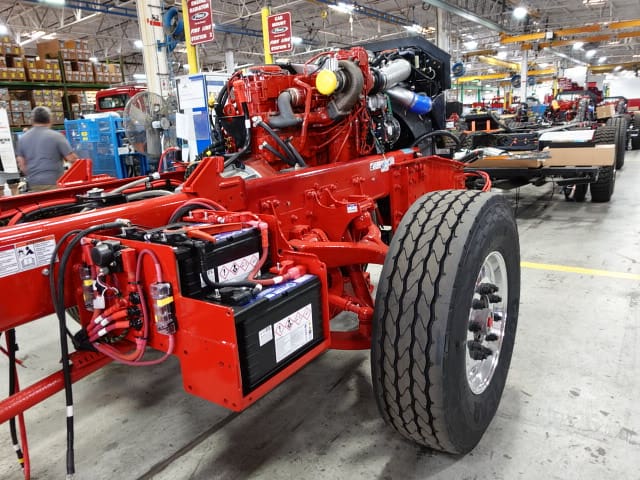

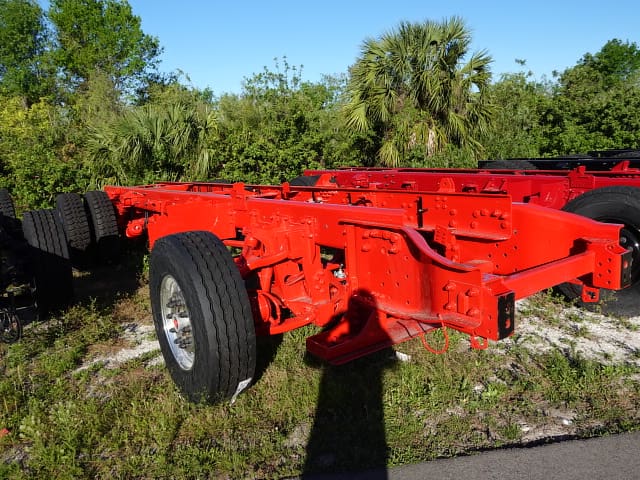

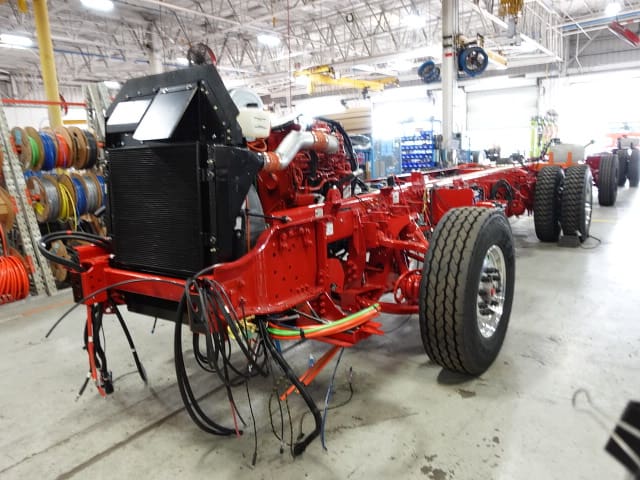

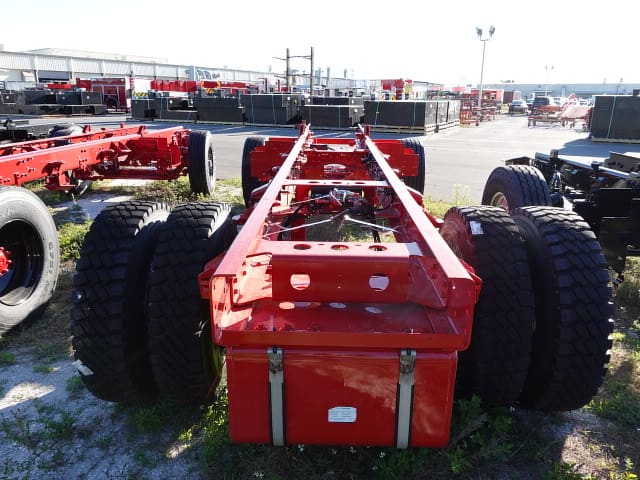

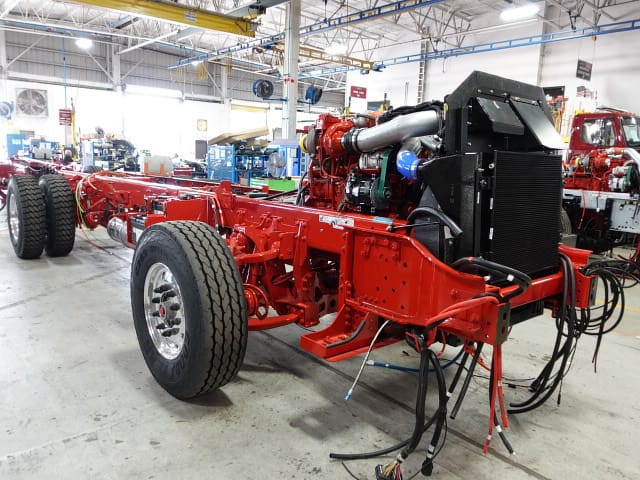

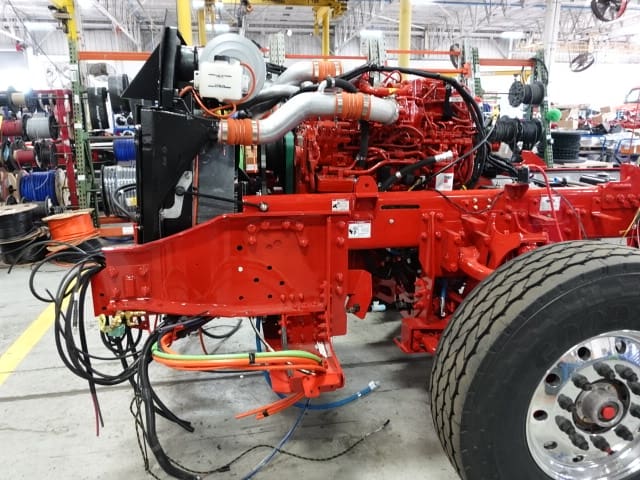

This new Pierce apparatus is now in production! In this report, the frame build began.
