10-17-25

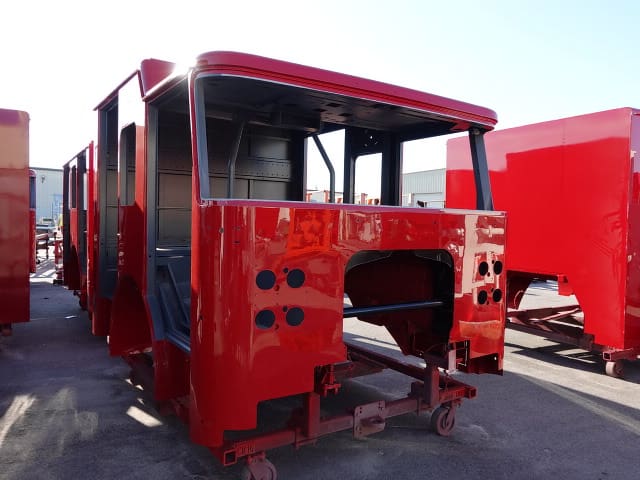

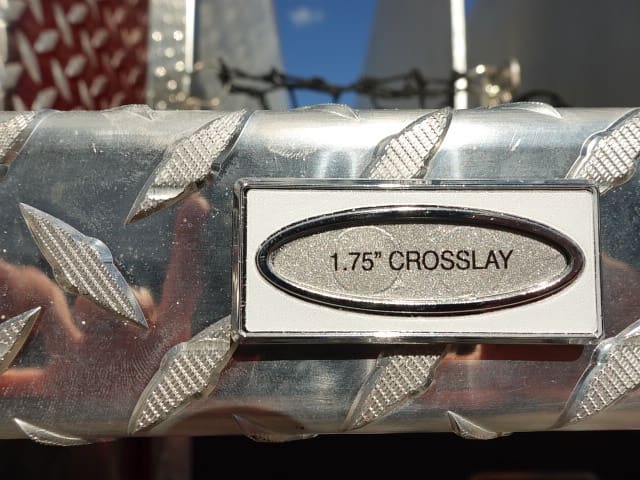

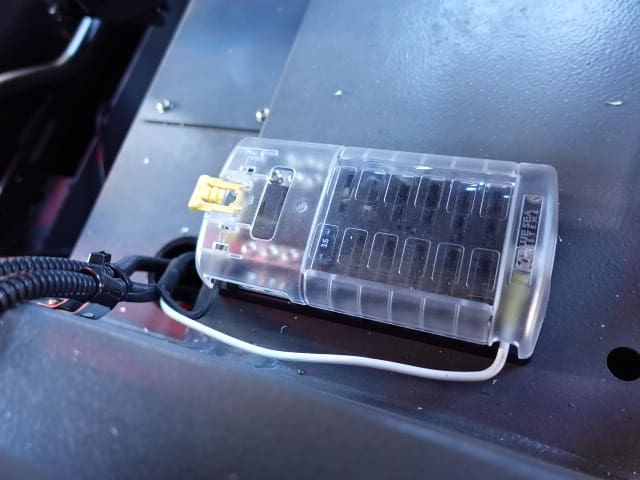

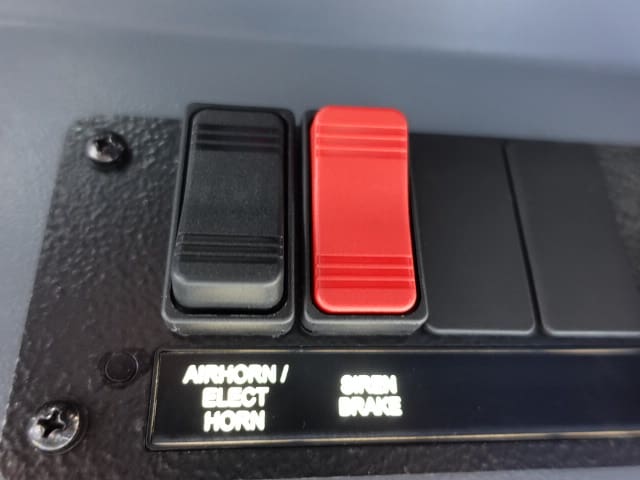

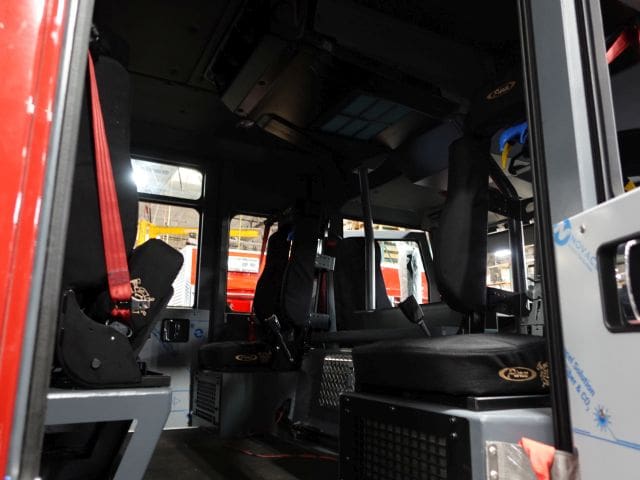

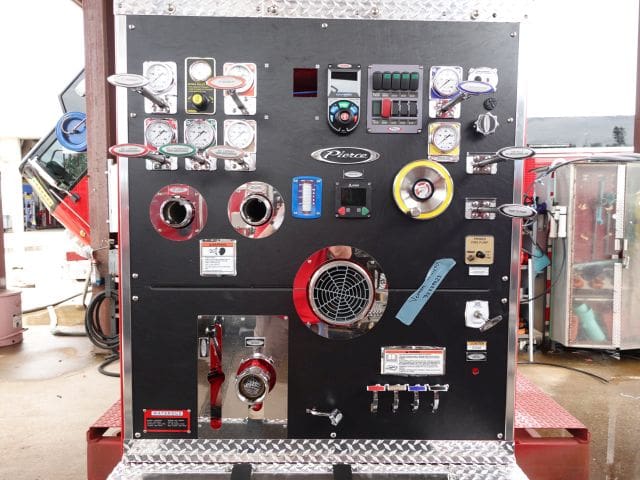

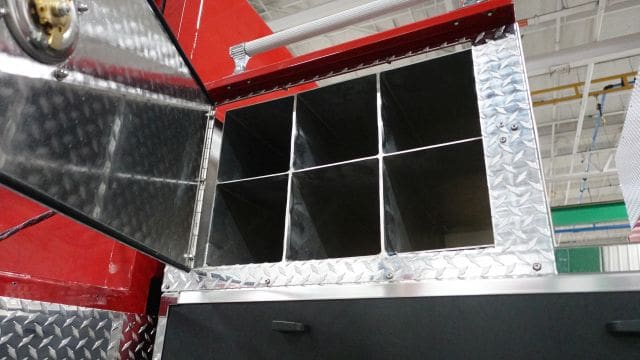

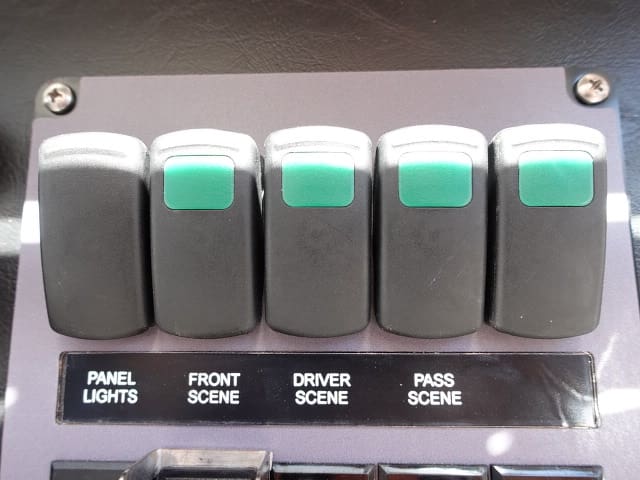

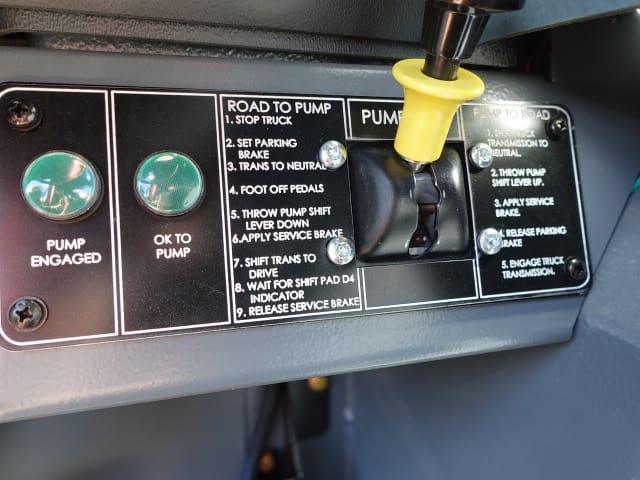

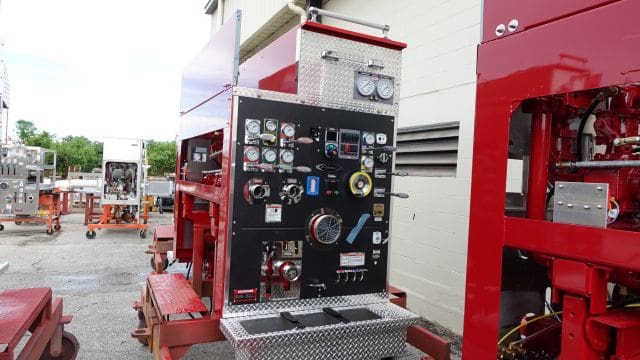

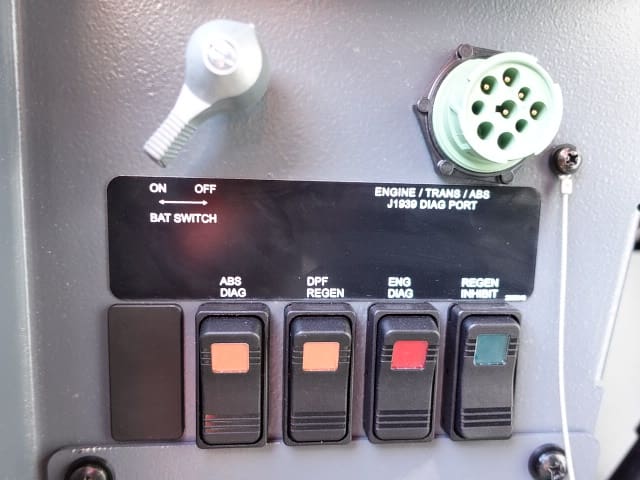

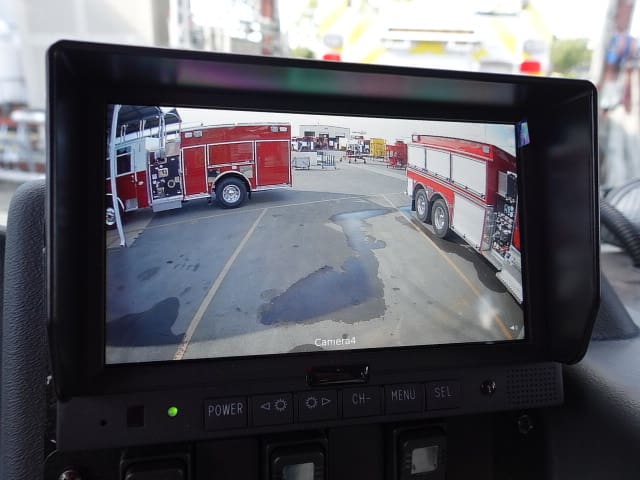

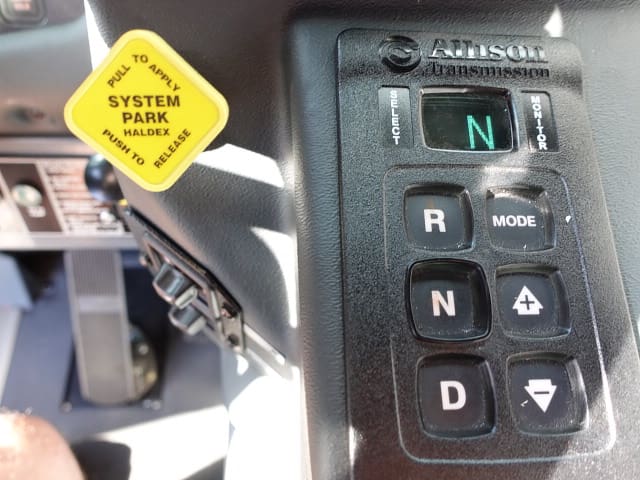

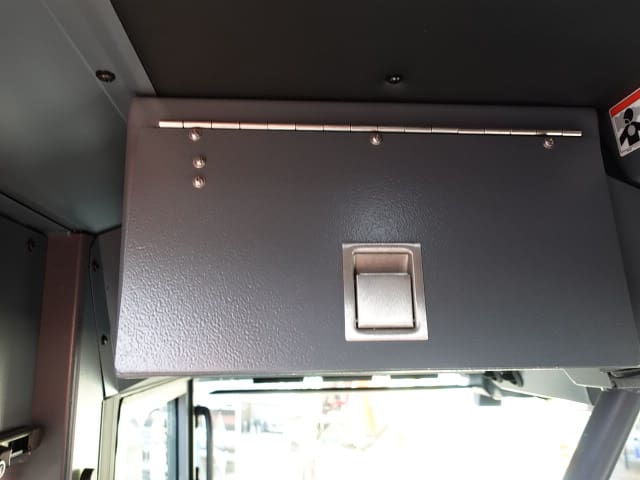

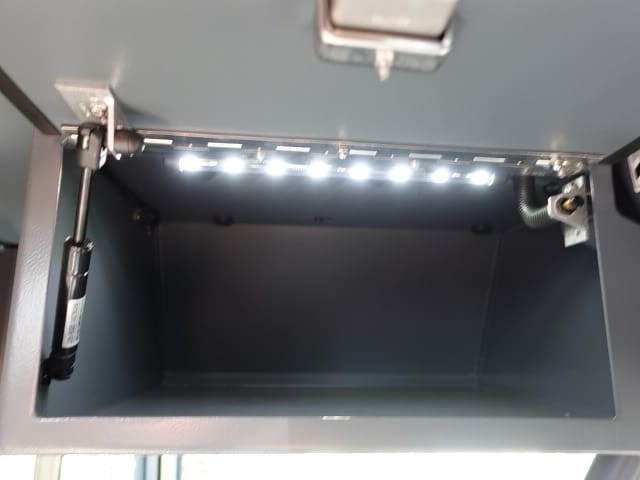

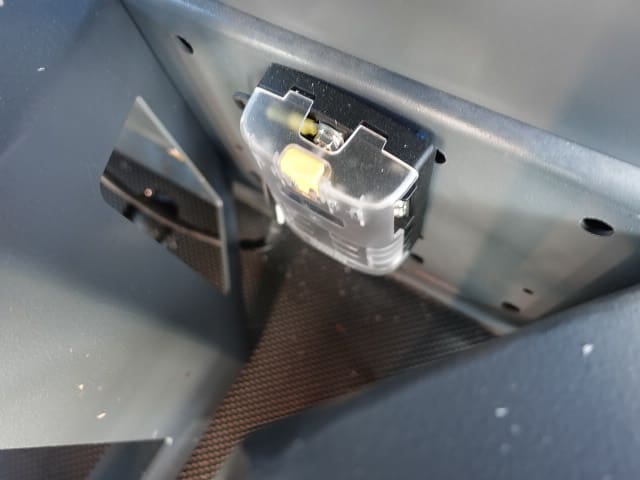

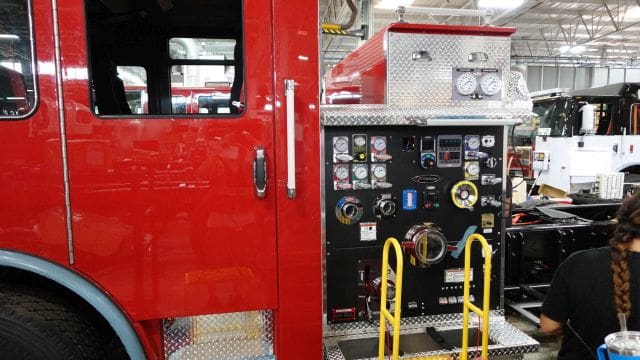

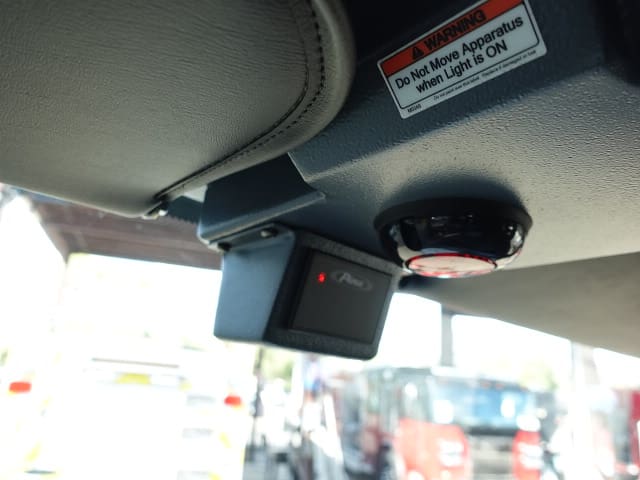

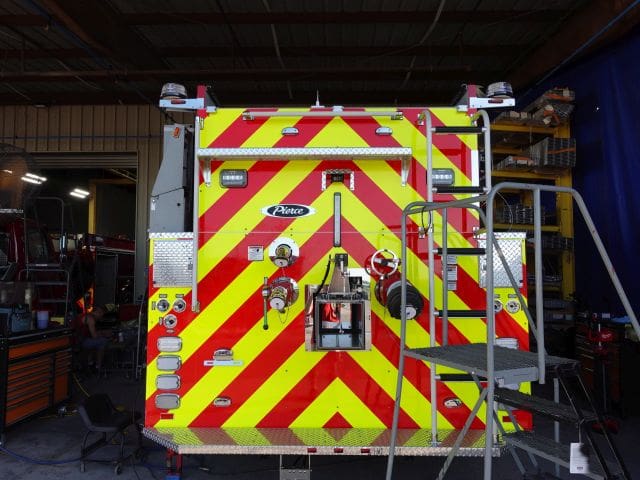

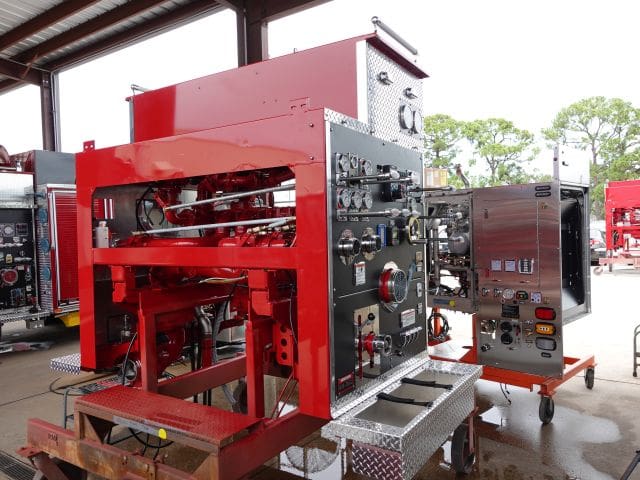

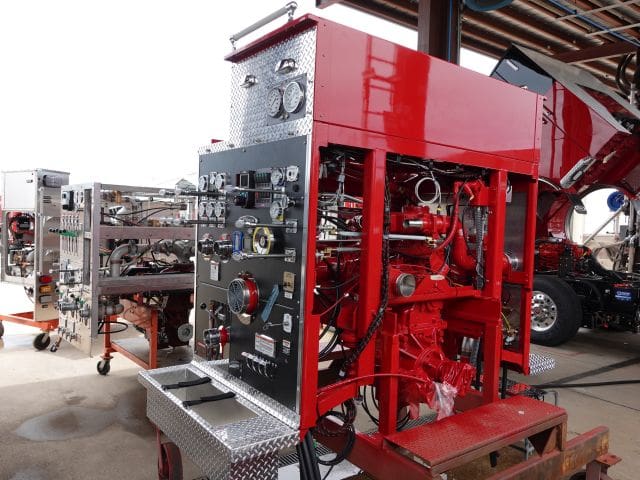

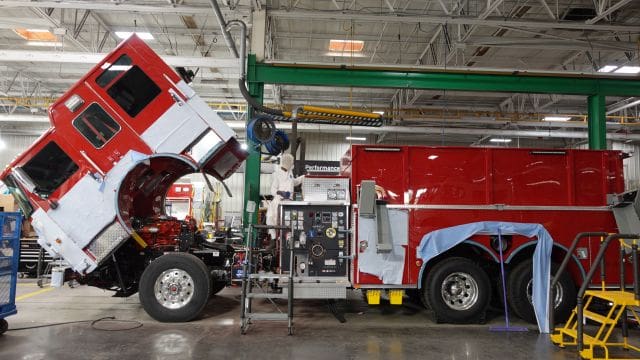

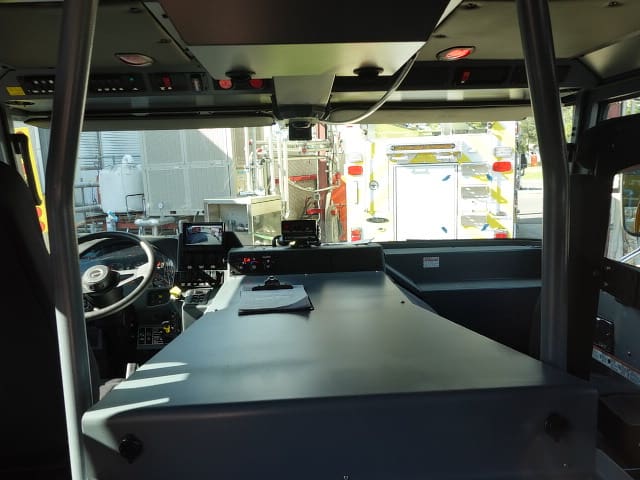

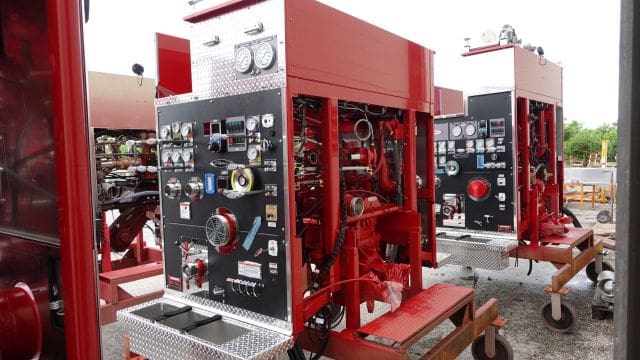

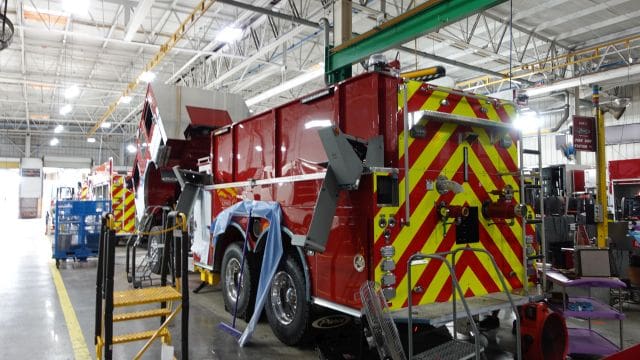

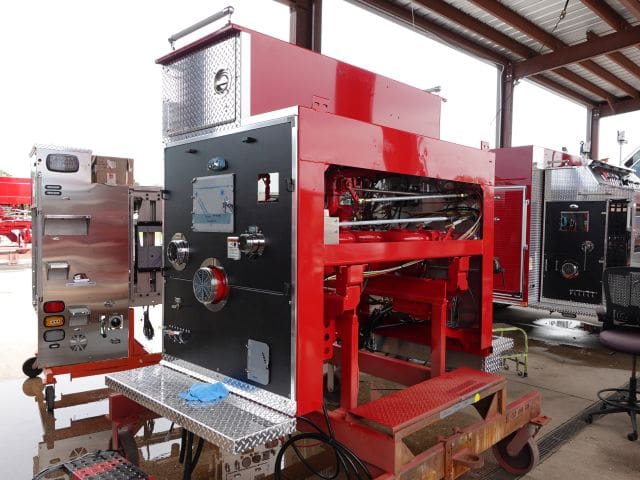

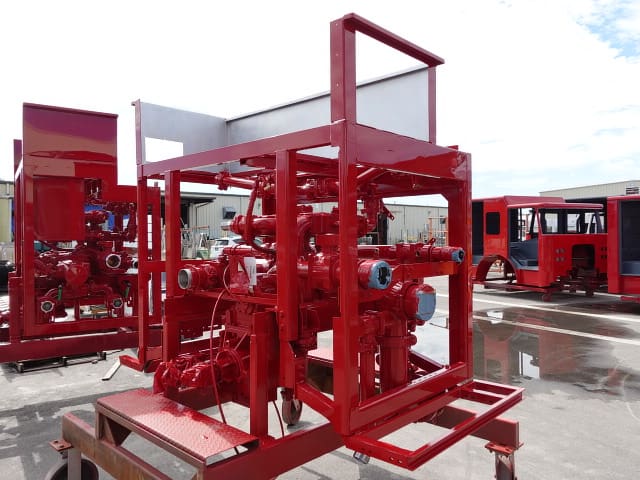

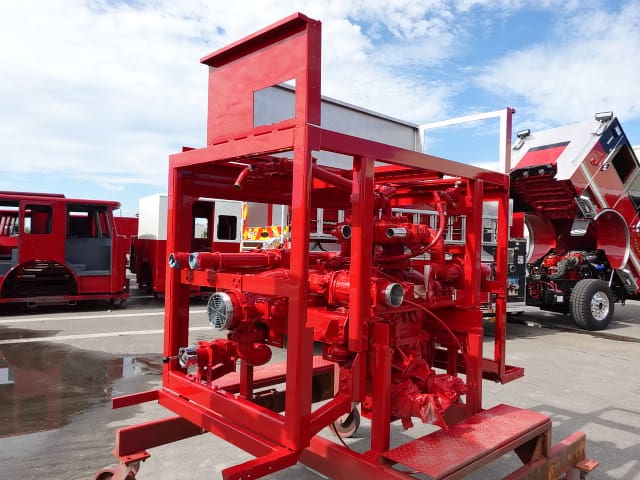

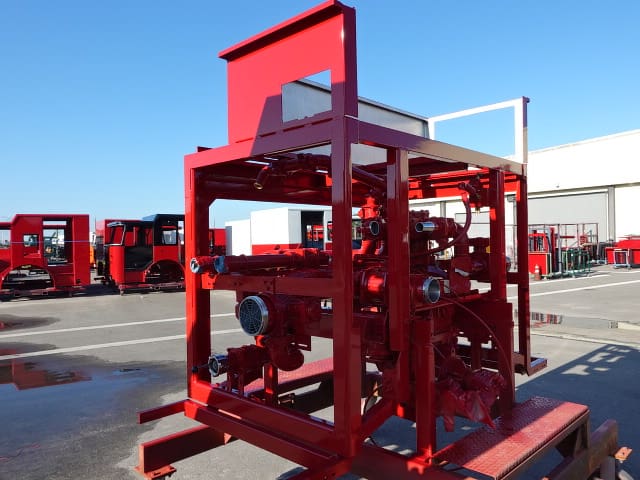

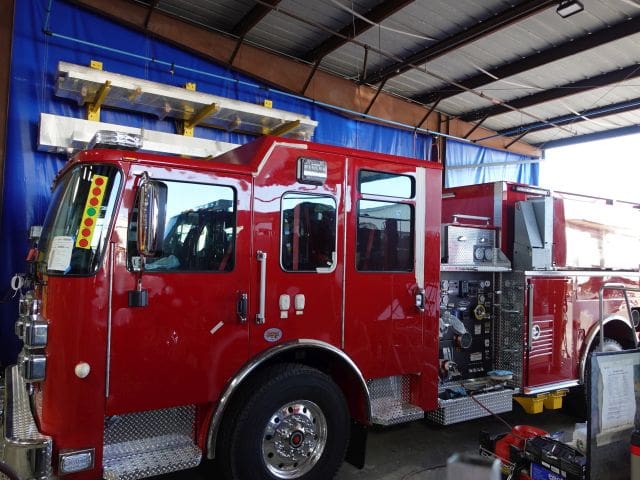

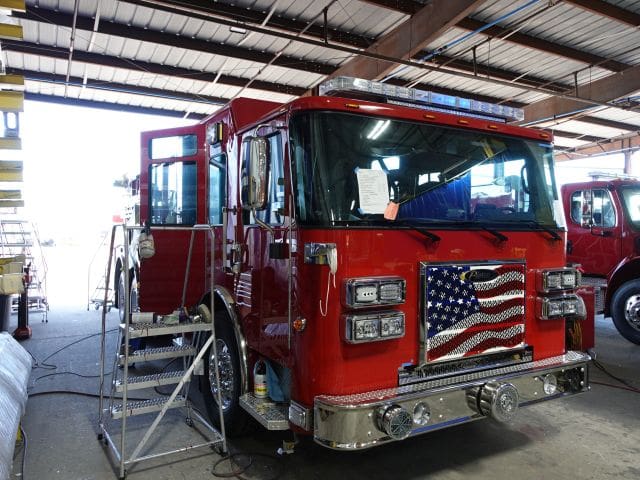

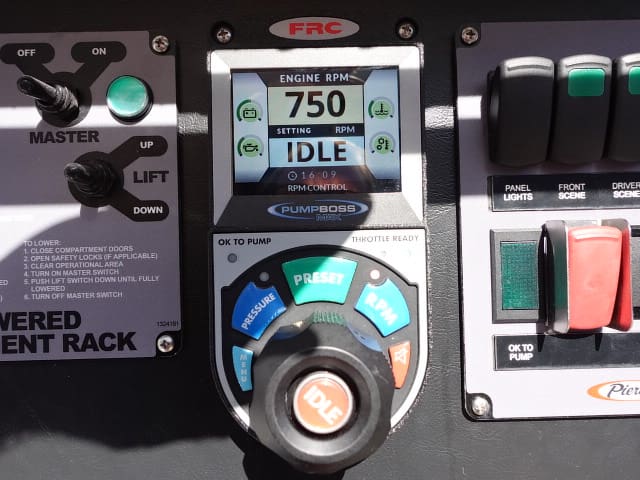

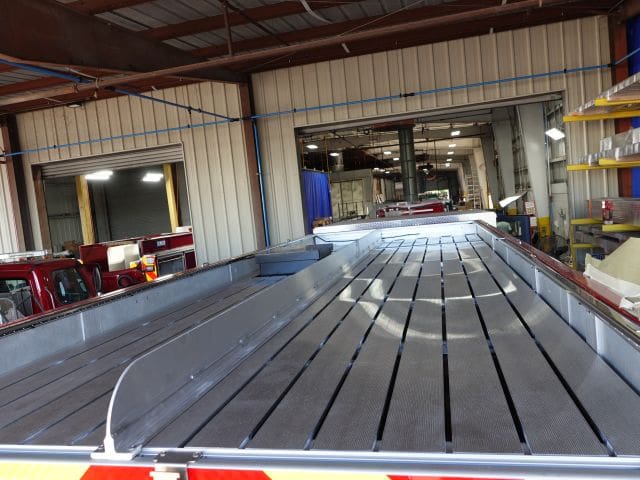

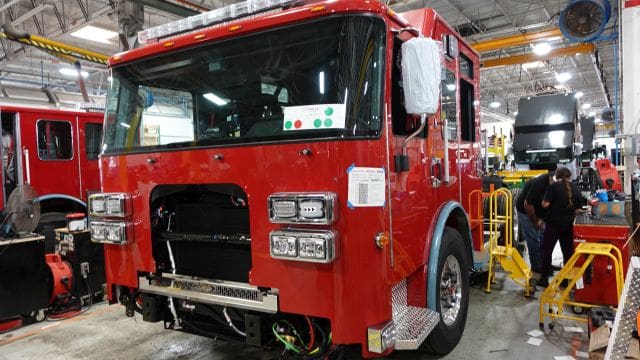

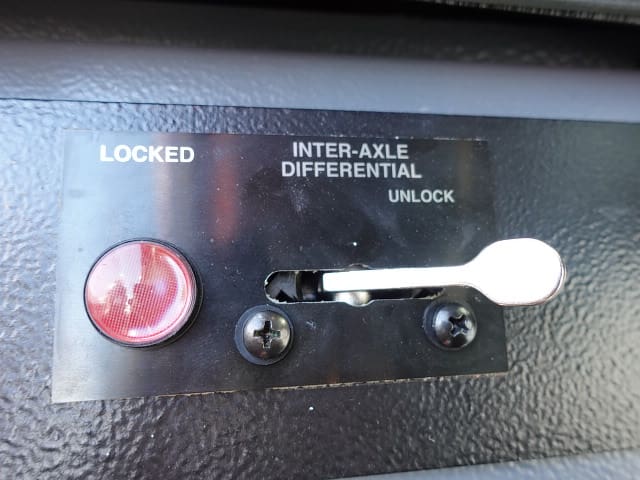

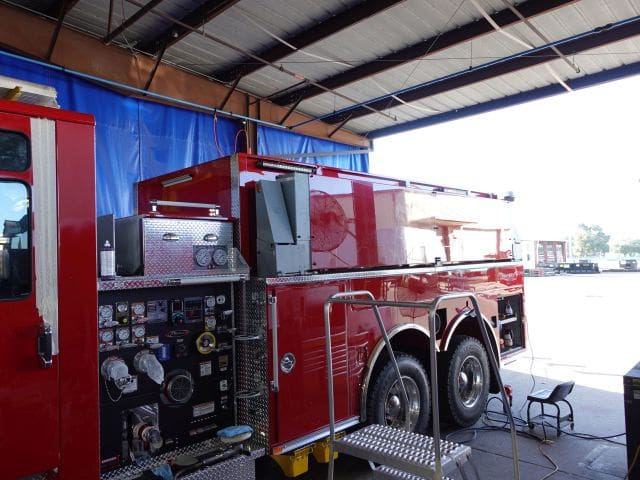

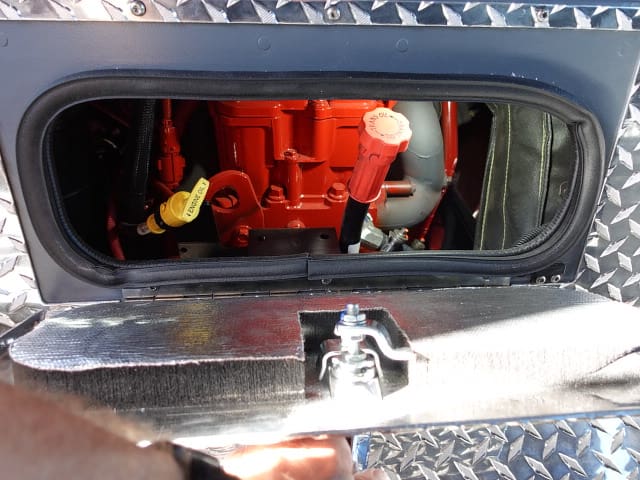

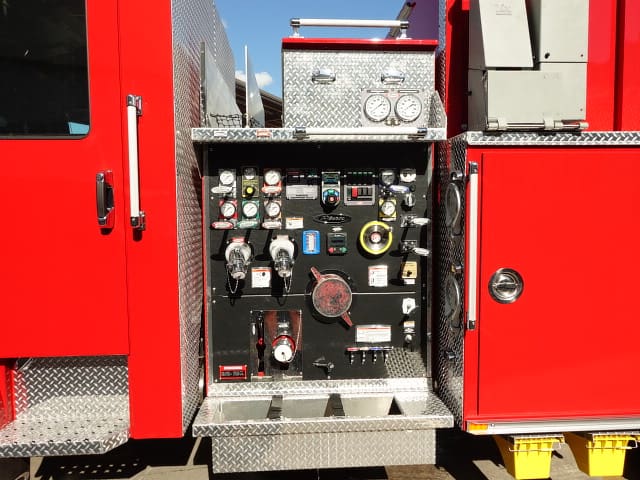

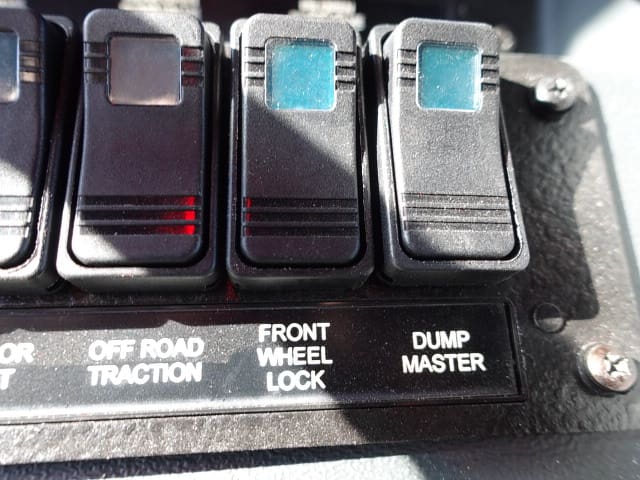

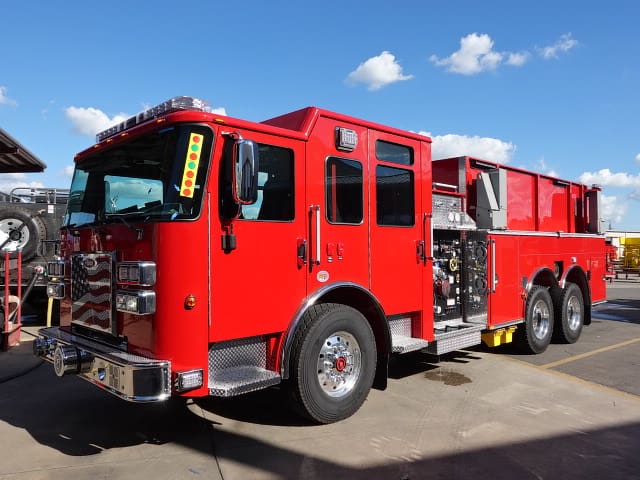

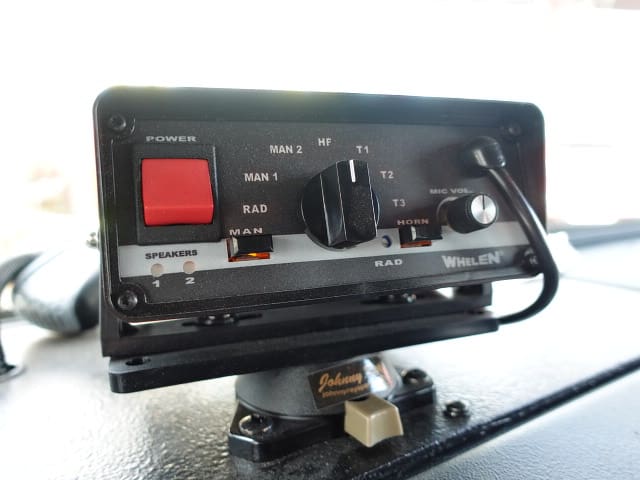

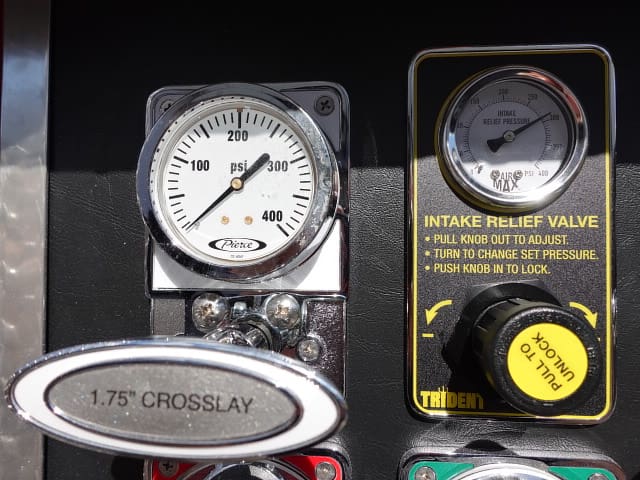

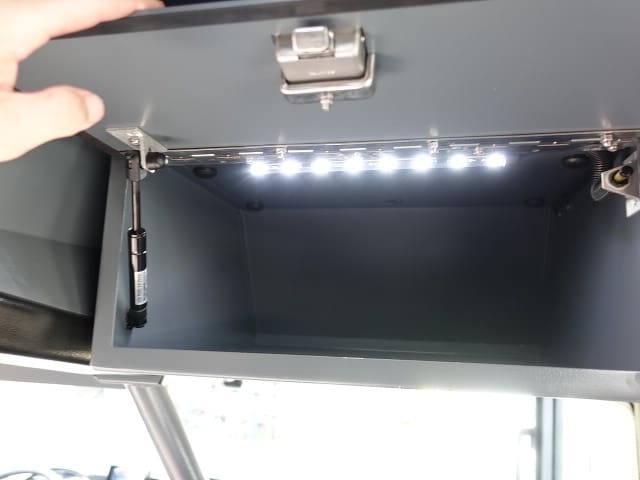

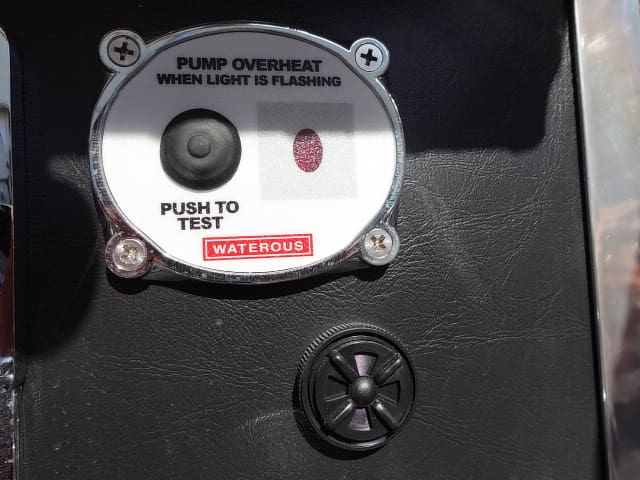

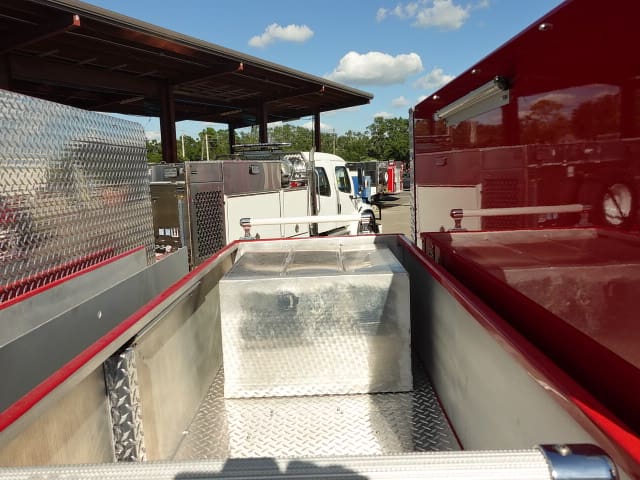

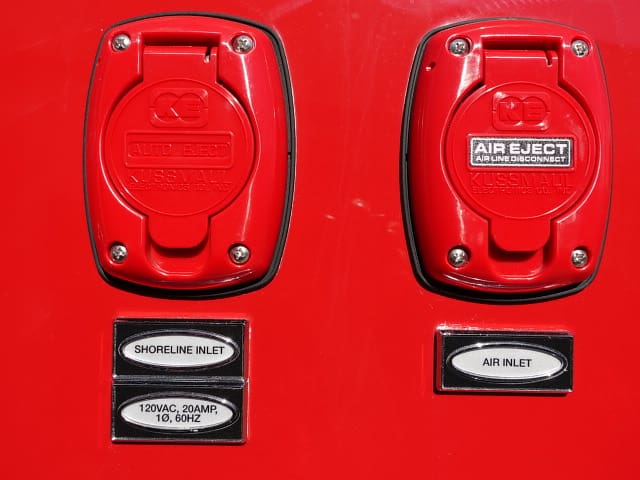

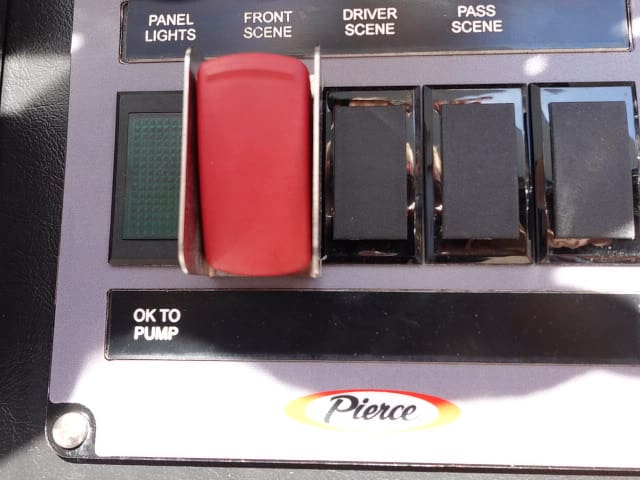

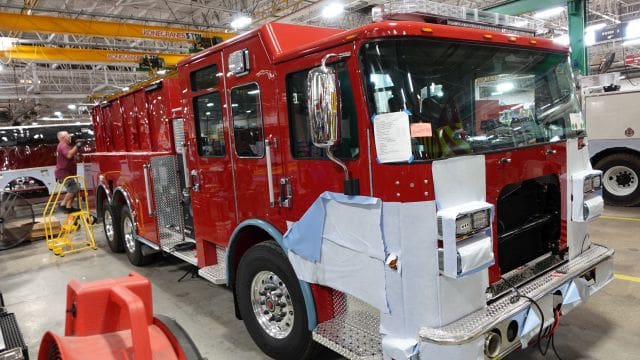

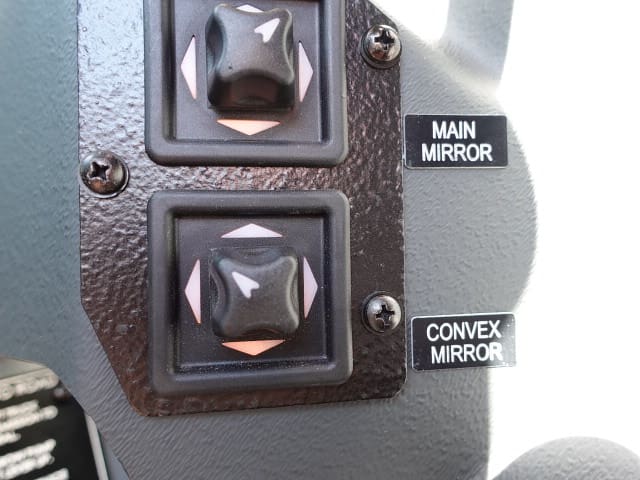

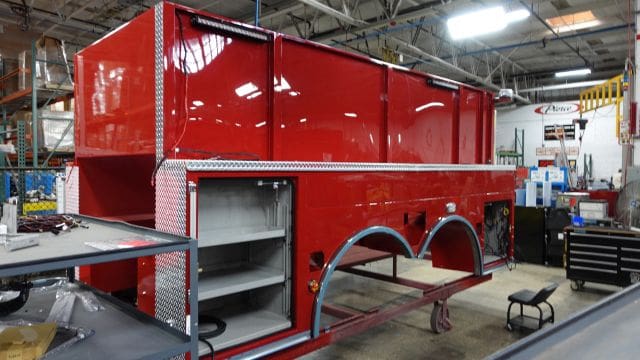

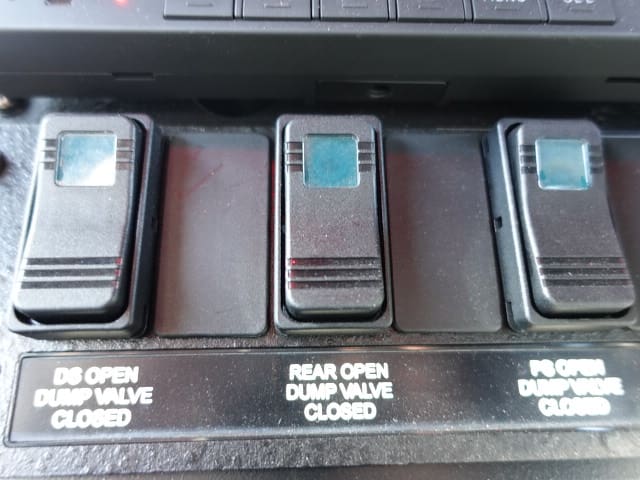

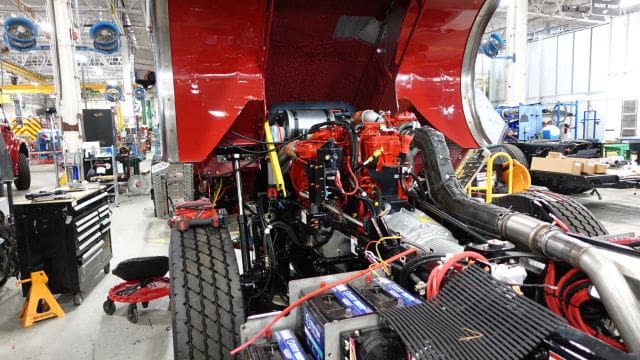

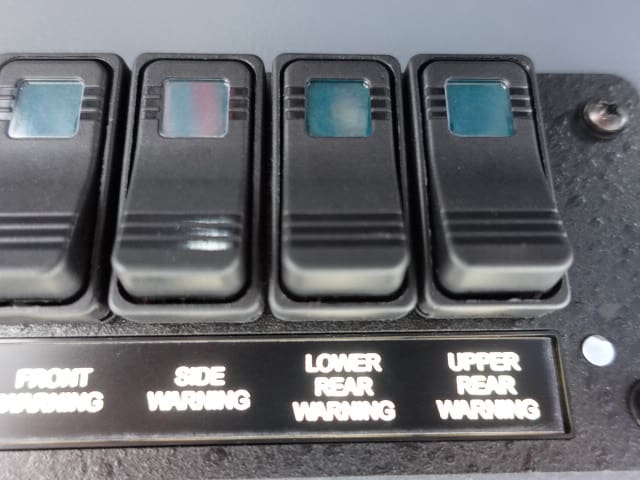

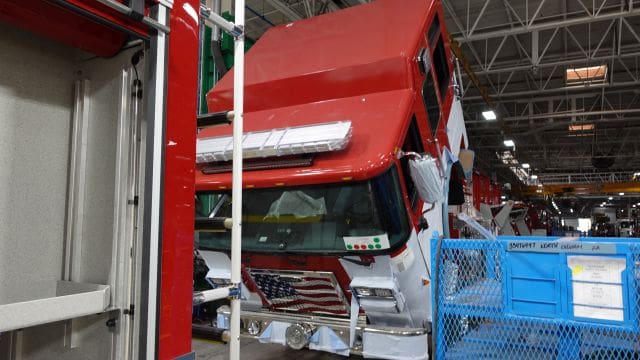

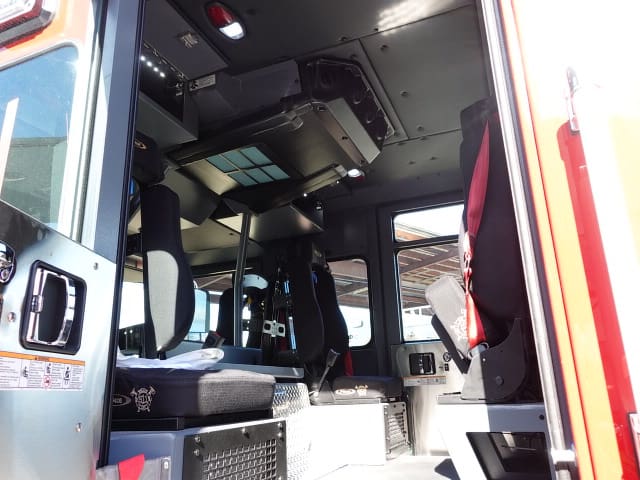

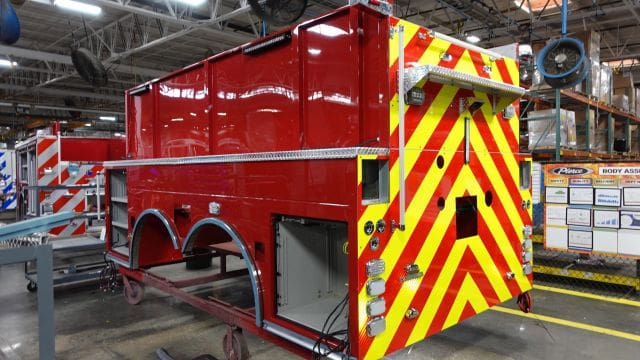

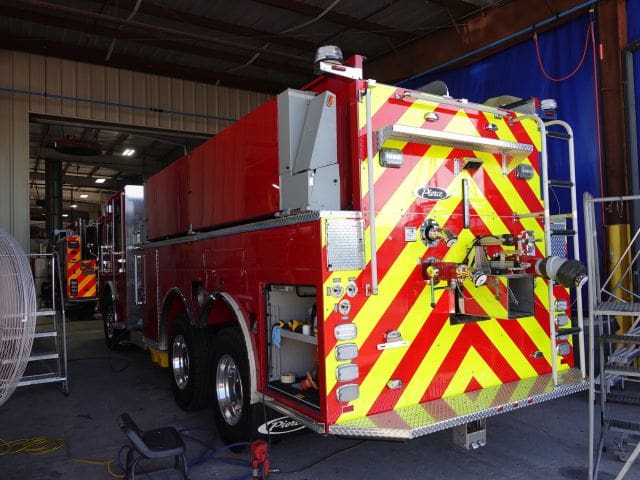

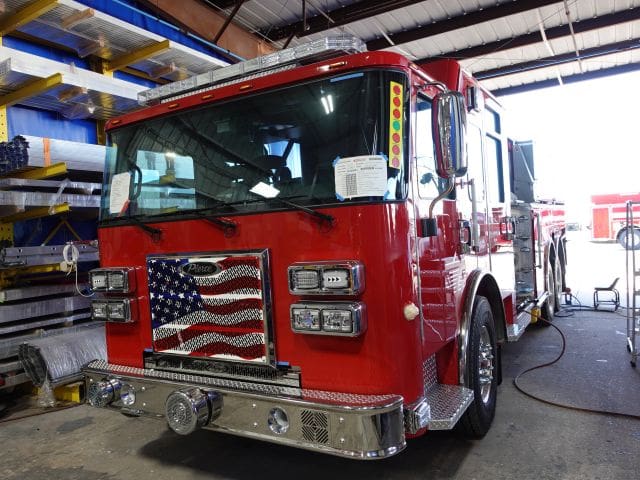

In this report, the apparatus completed final assembly and released to test. When testing completes it will release to final product evaluation where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
09-26-25

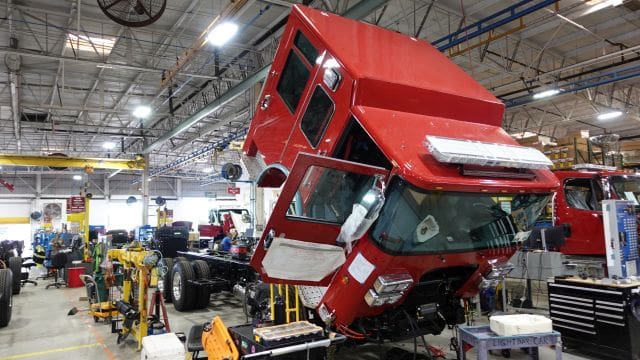

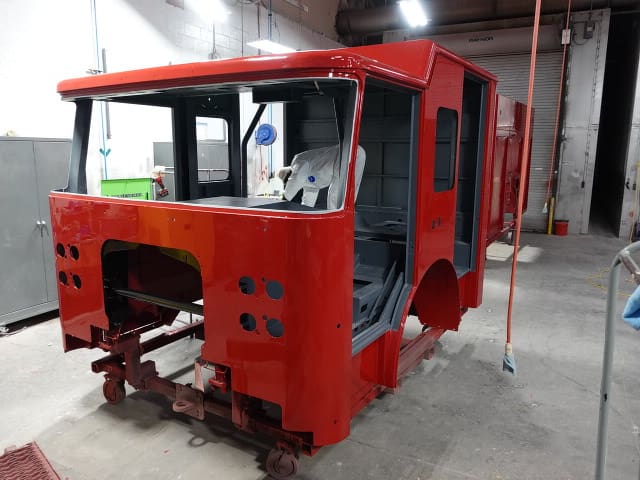

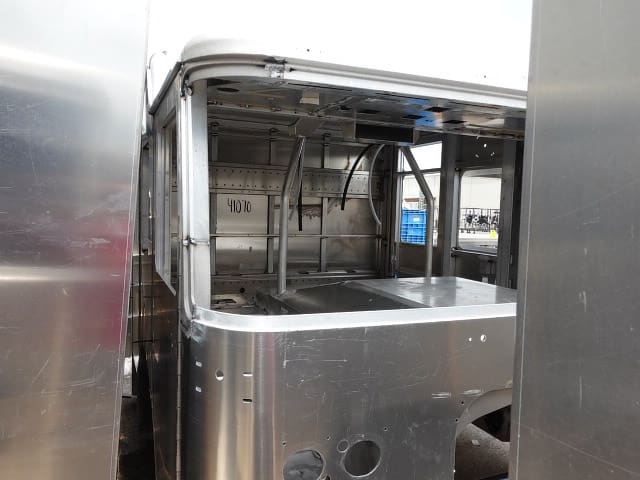

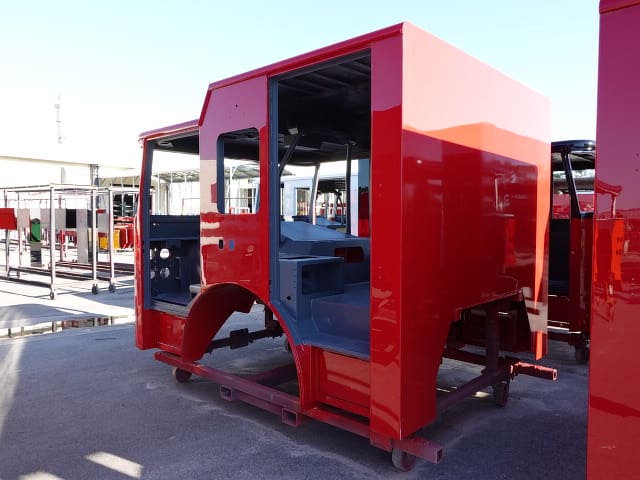

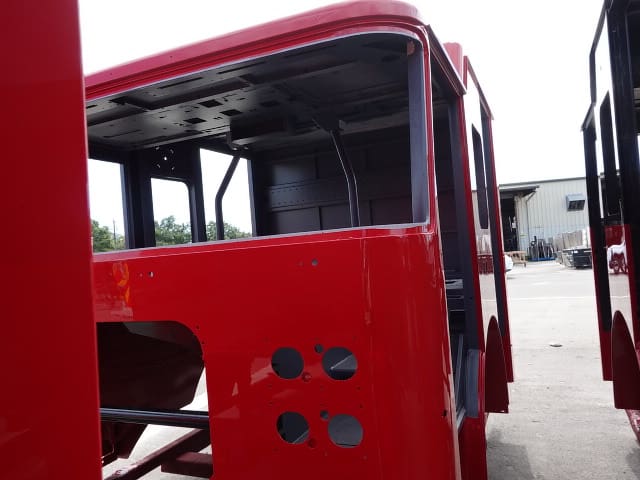

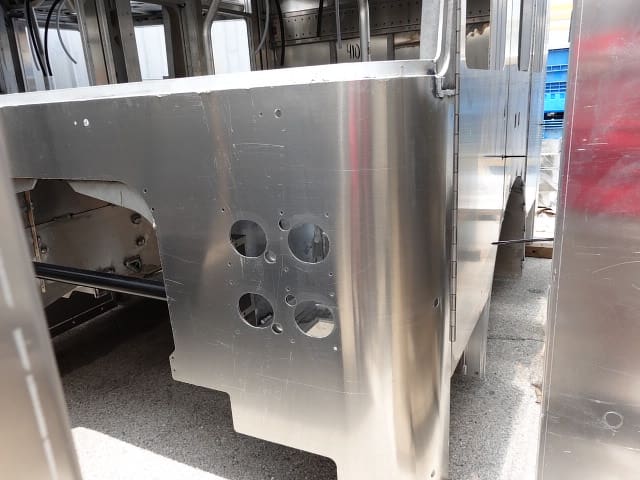

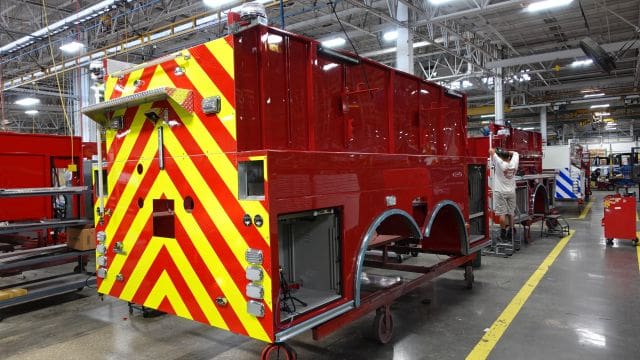

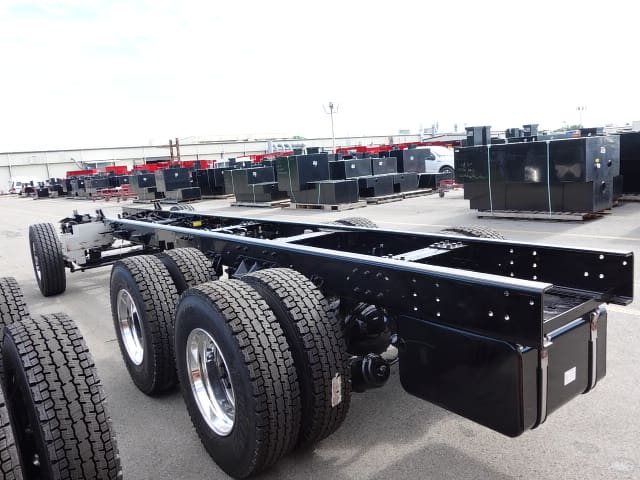

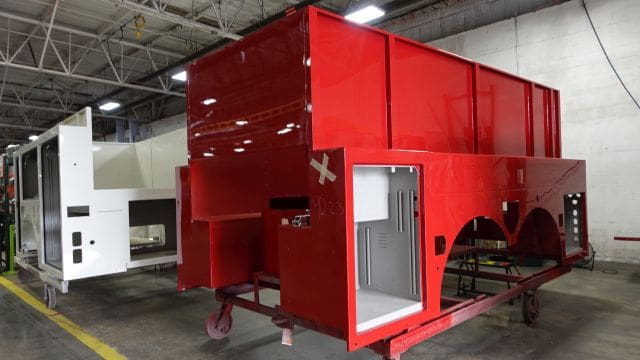

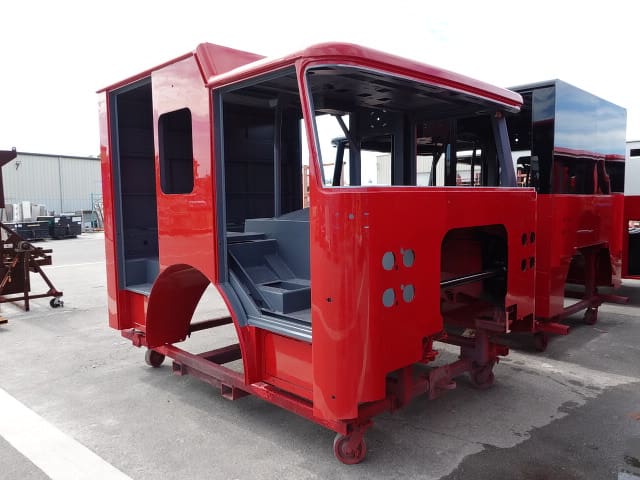

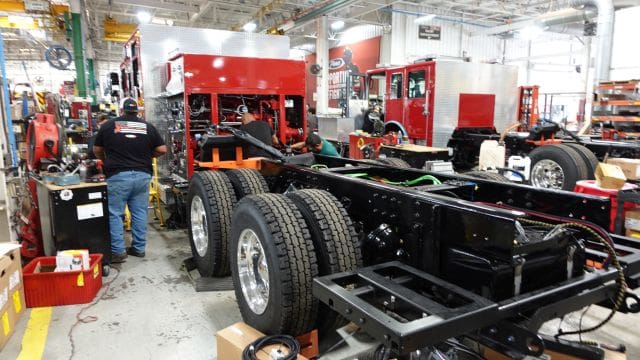

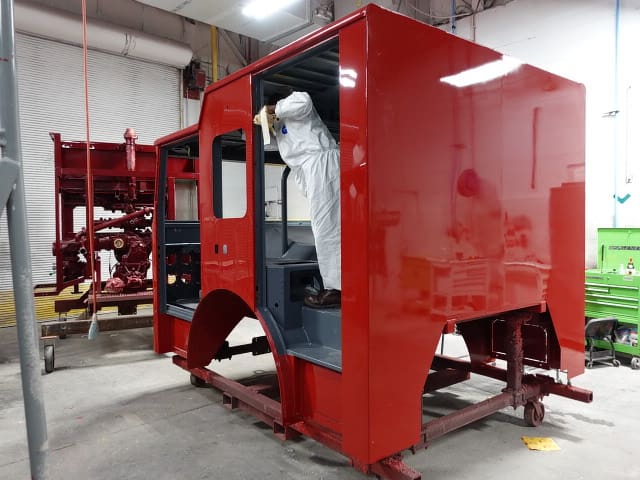

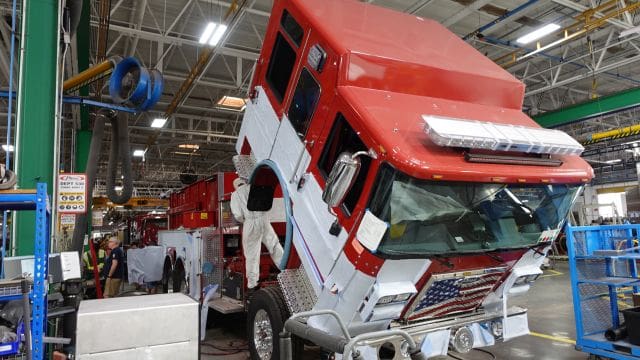

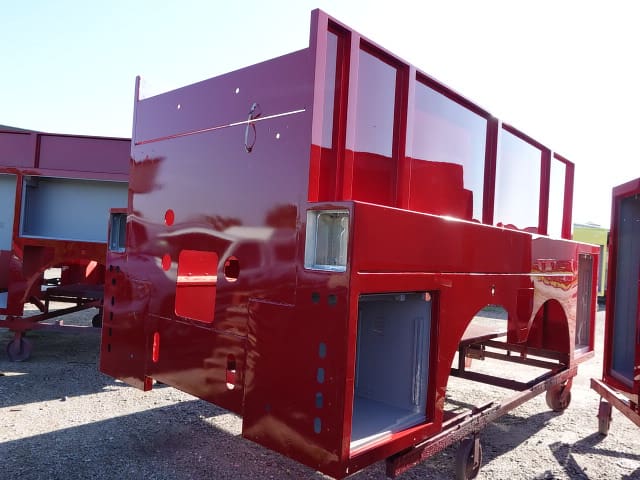

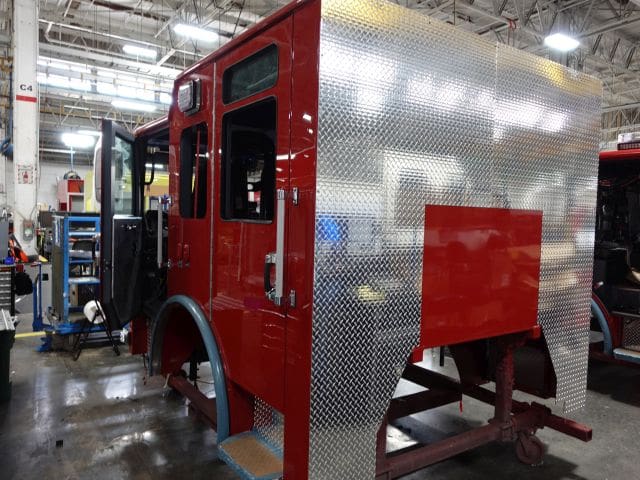

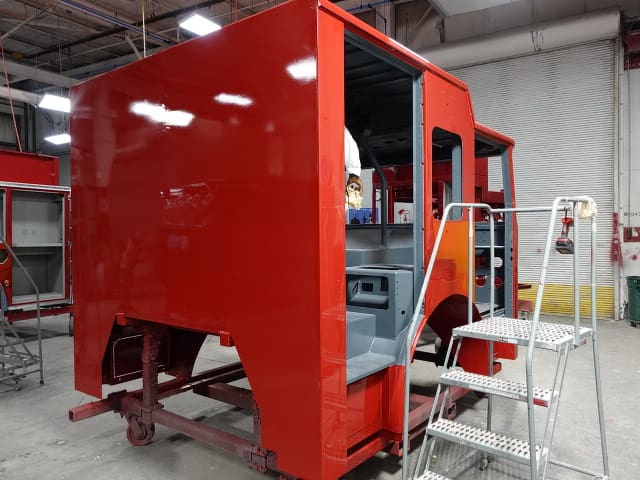

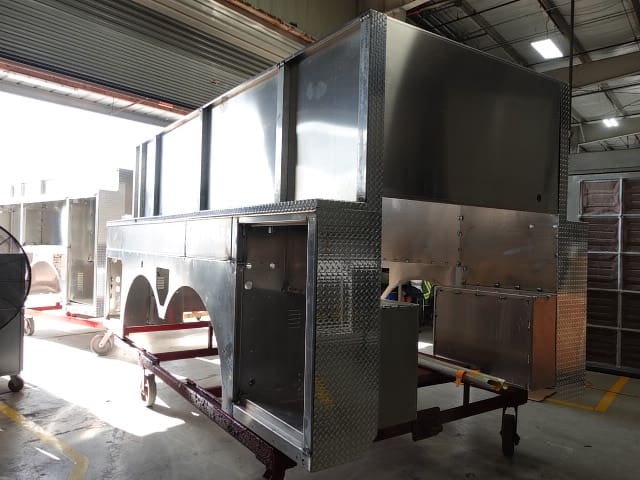

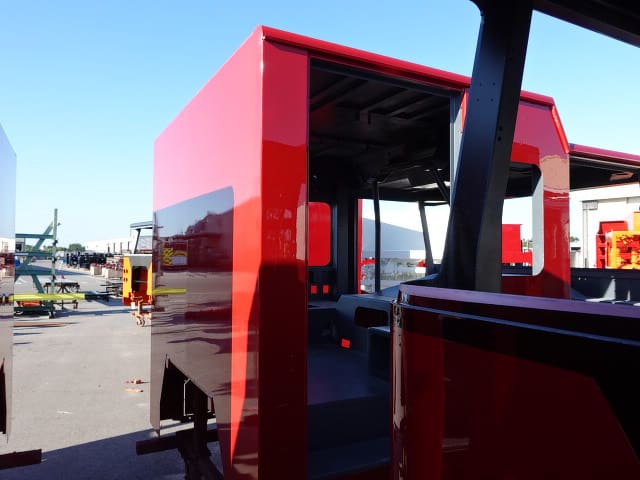

In this report, the body completed initial assembly and was installed on the chassis. =
09-19-25

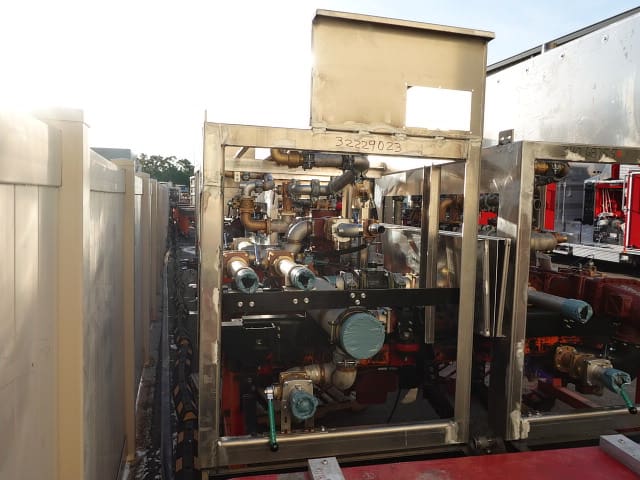

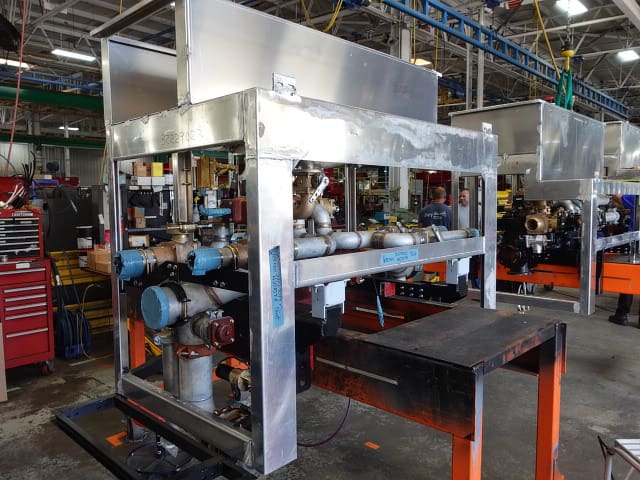

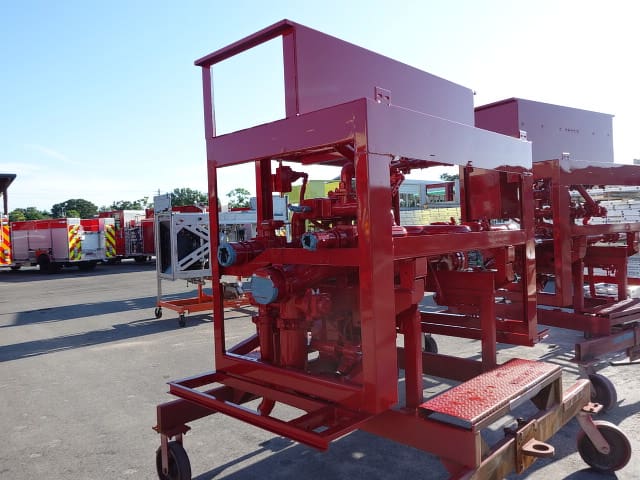

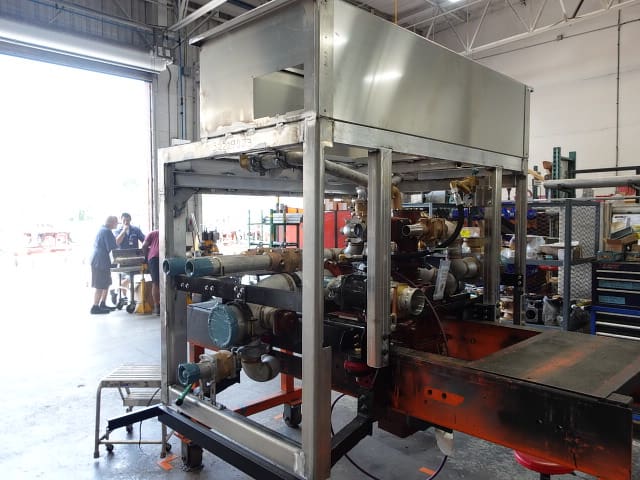

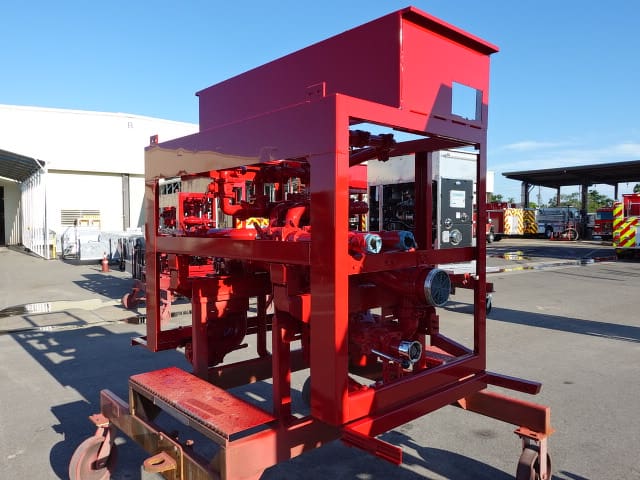

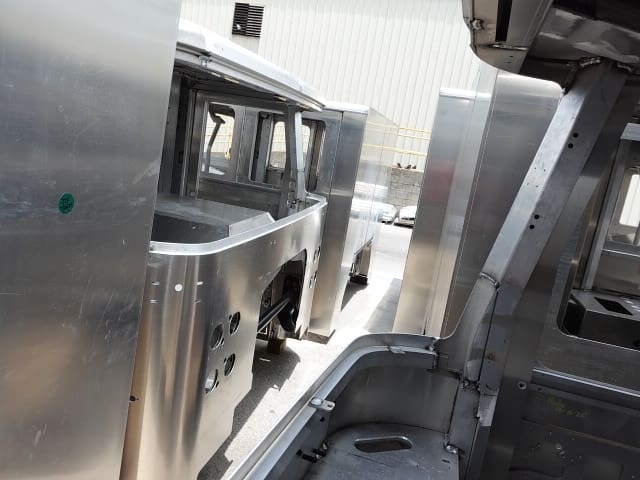

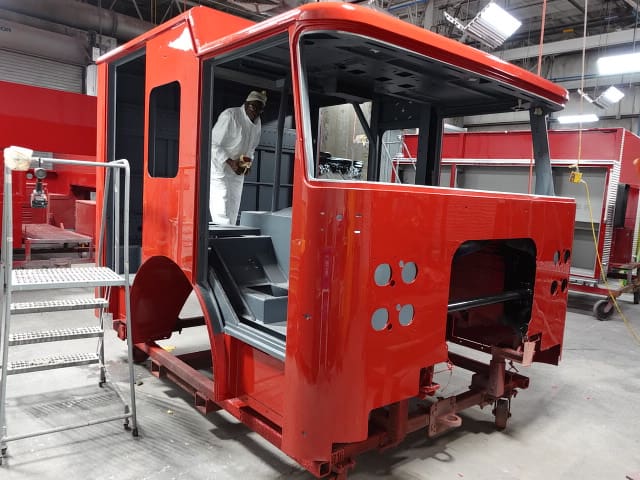

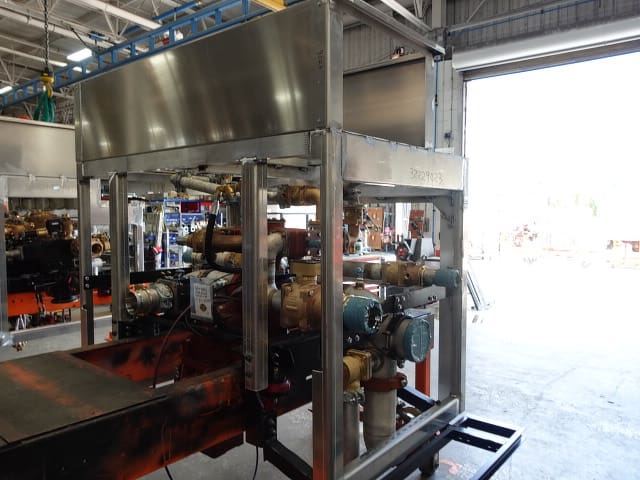

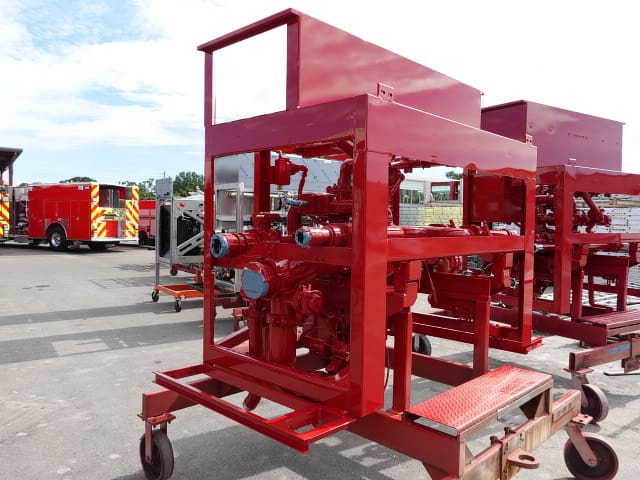

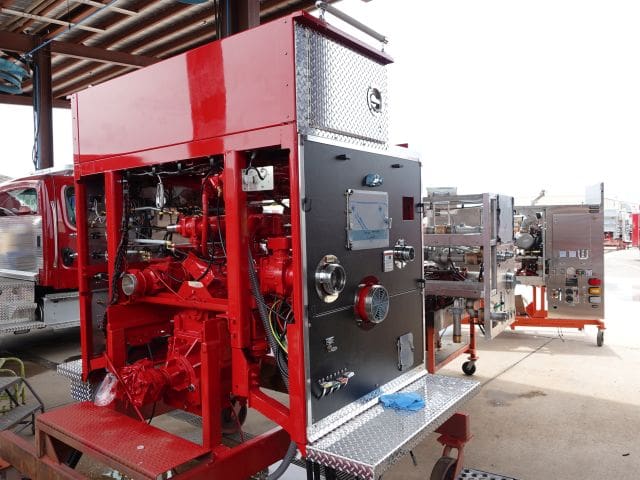

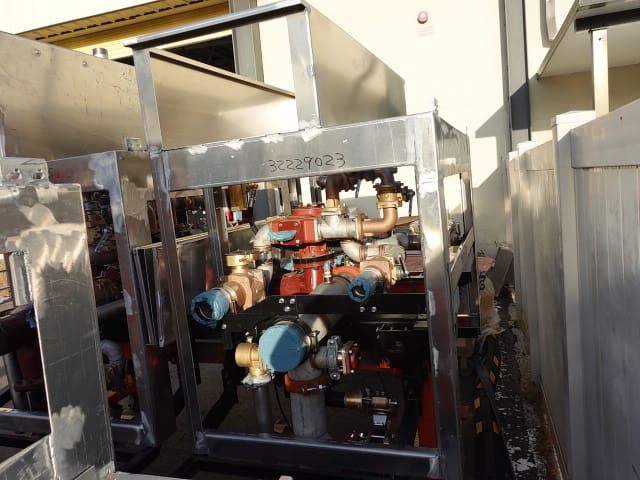

In this report, the pump house was merged with the chassis while the body continued initial assembly.
09-12-25

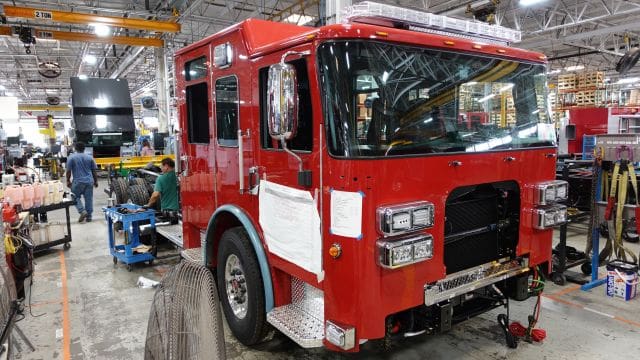

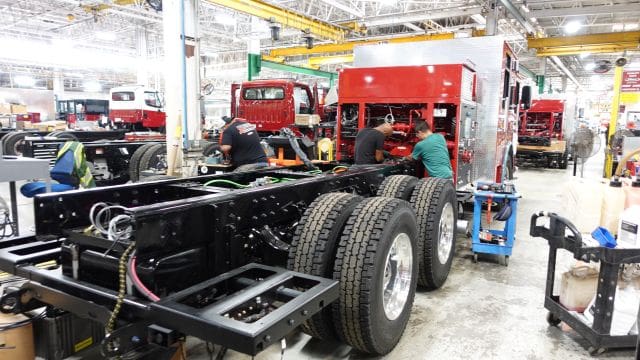

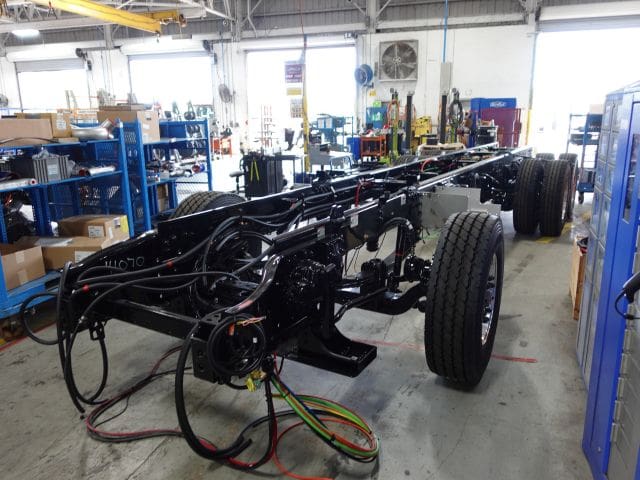

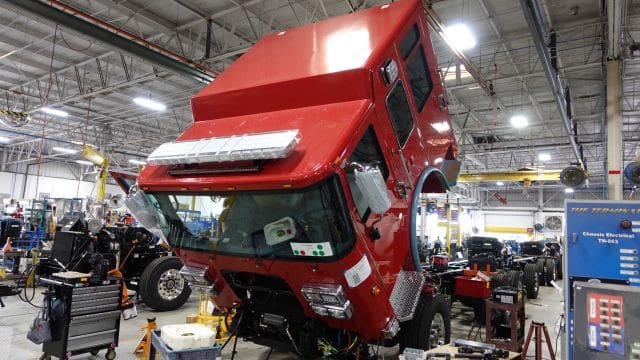

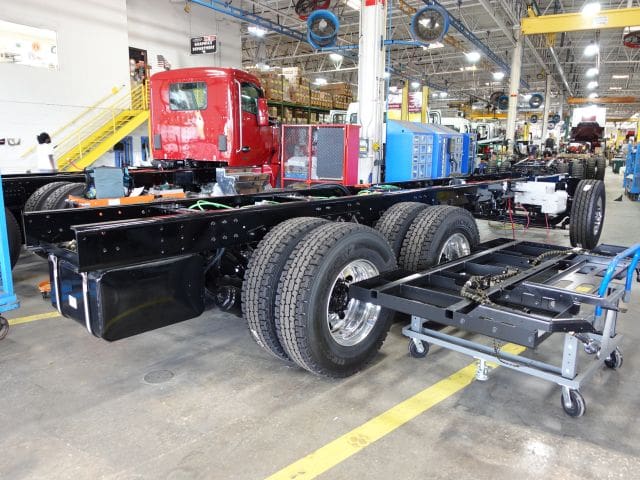

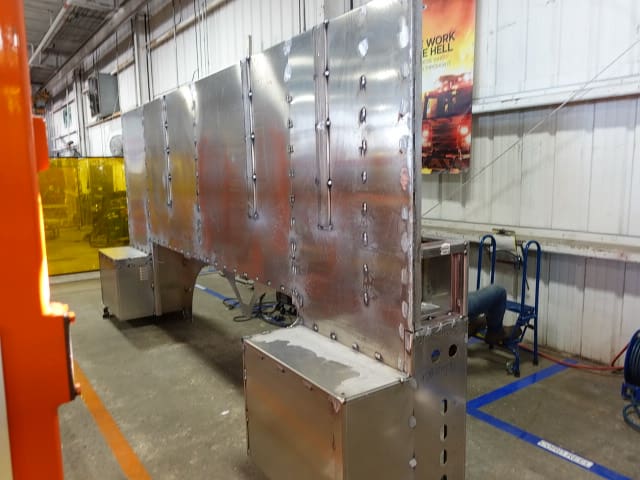

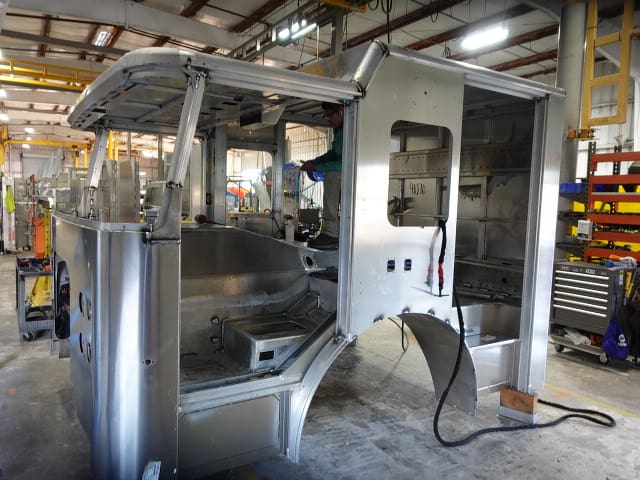

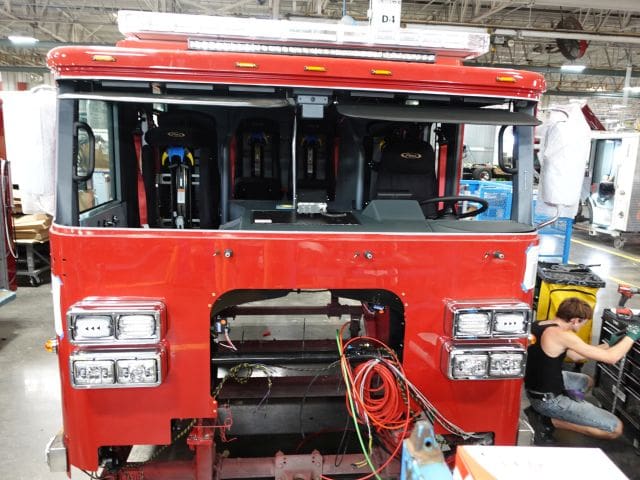

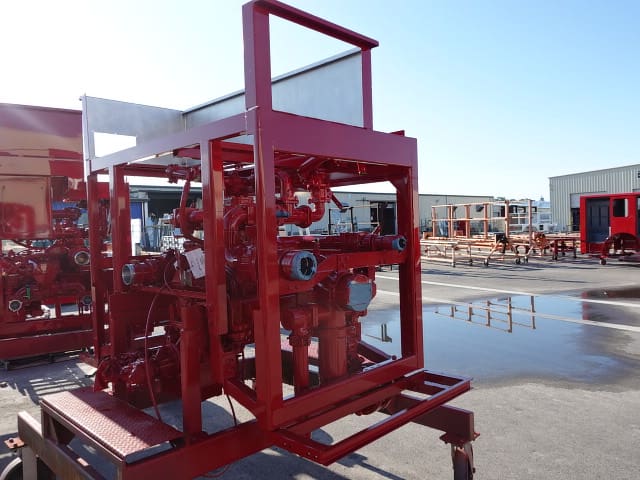

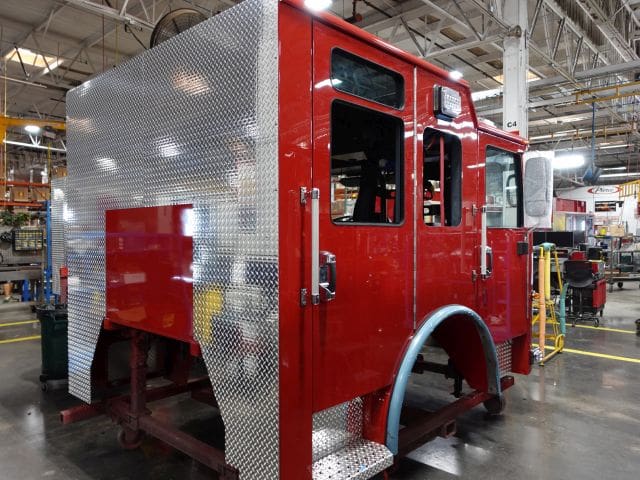

In this report, the cab completed initial assembly and was merged with the frame, the pump house was staged, and the body began initial assembly.

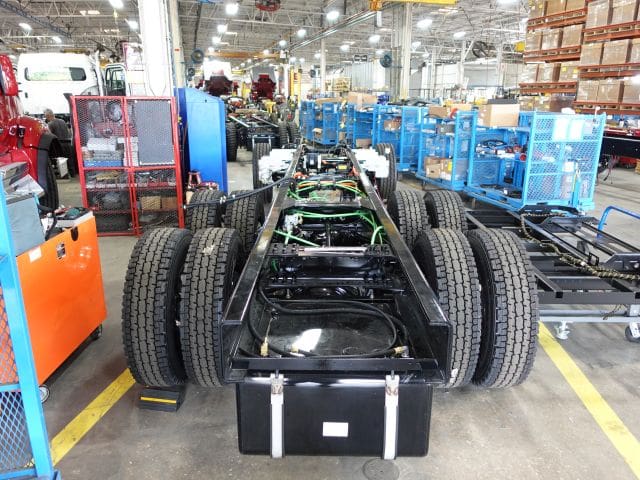

09-05-25
In this report, your cab continued initial assembly, the frame build continued, the pump house completed initial assembly, and the body remained staged (no photos).
08-22-25

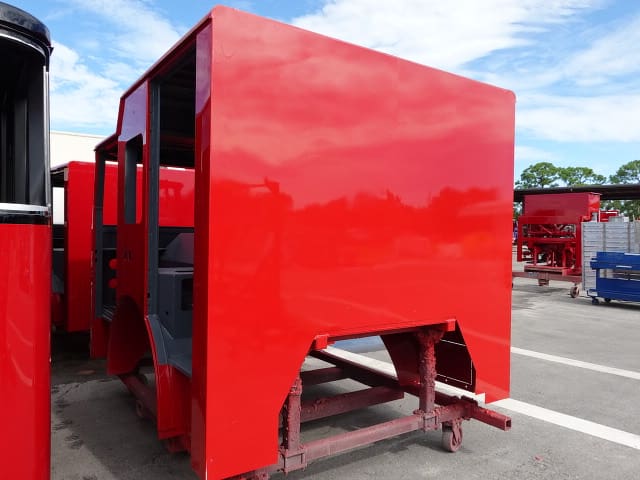

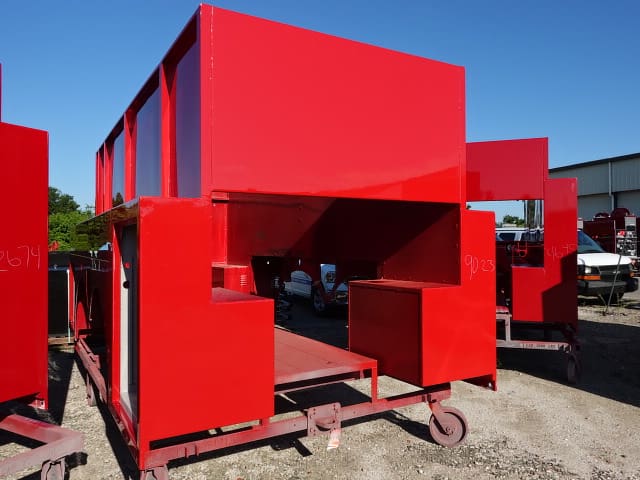

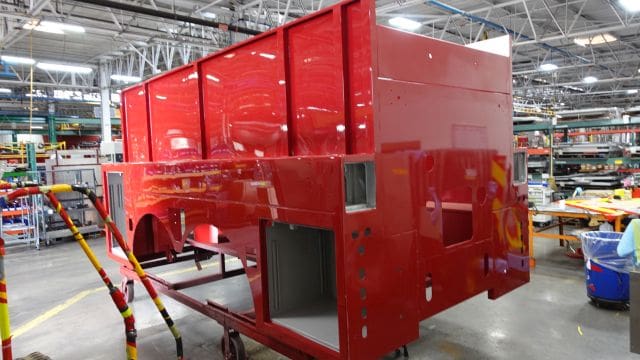

In this report, the cab was staged, the frame was staged (no photos), the pump house remained staged, and the body completed the paint process.

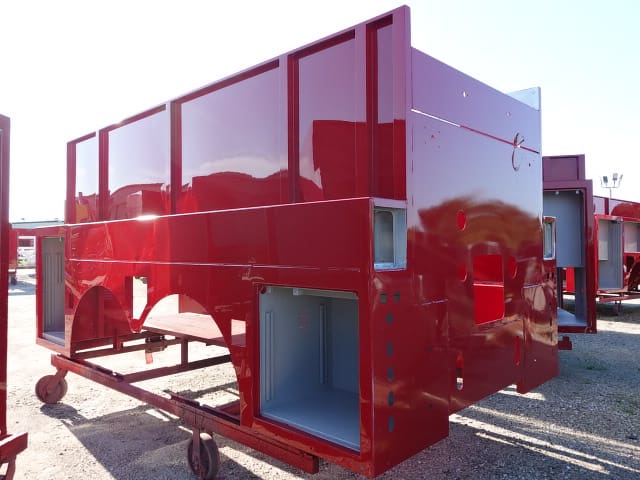

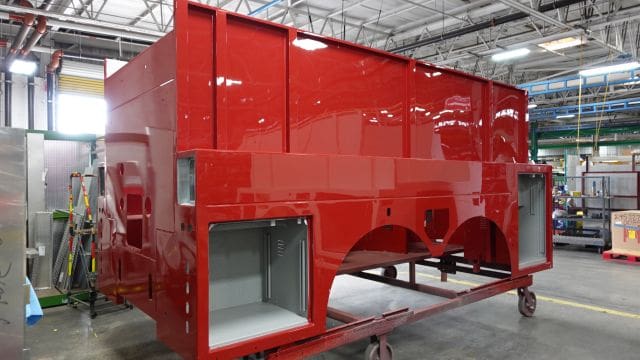

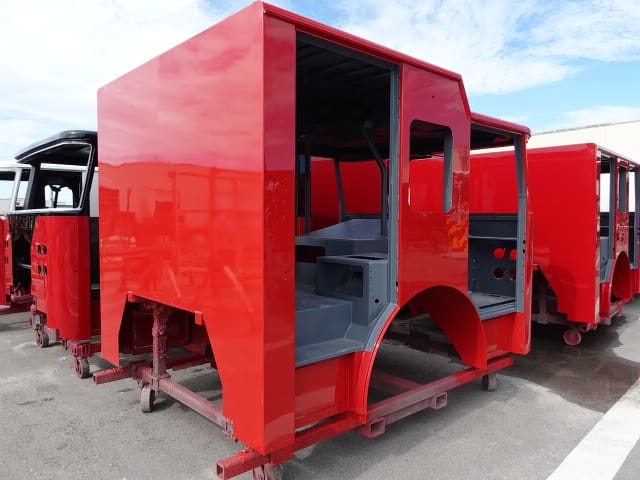

08-15-25

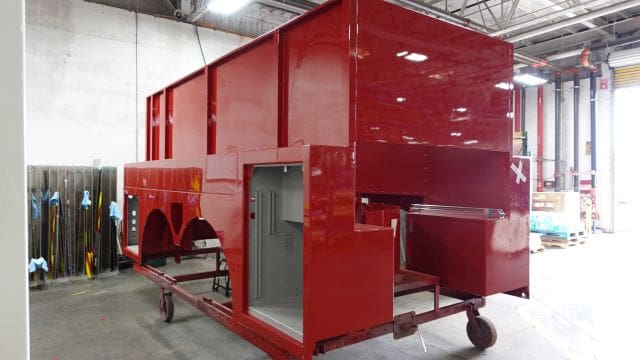

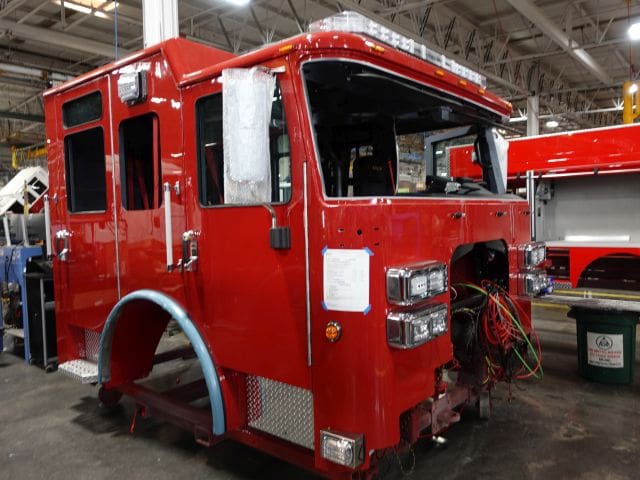

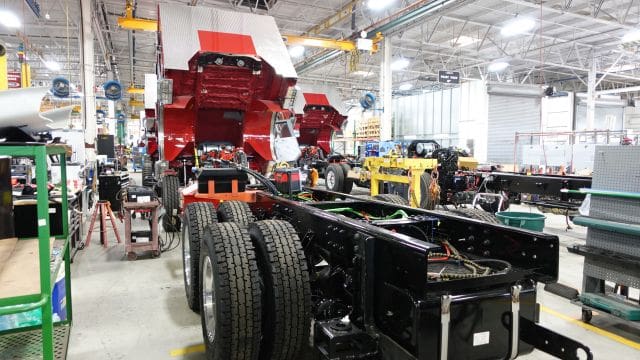

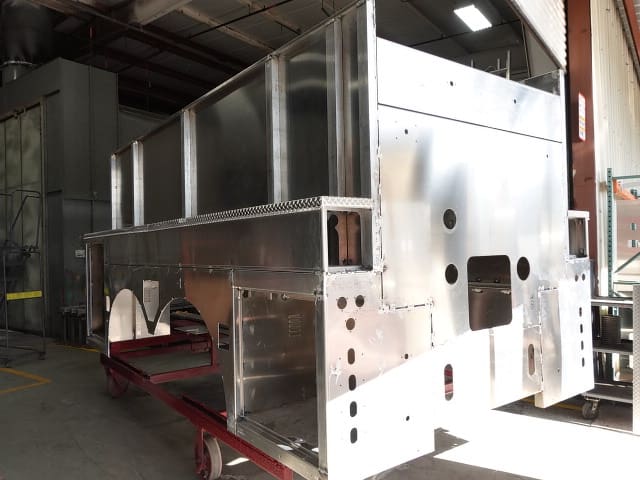

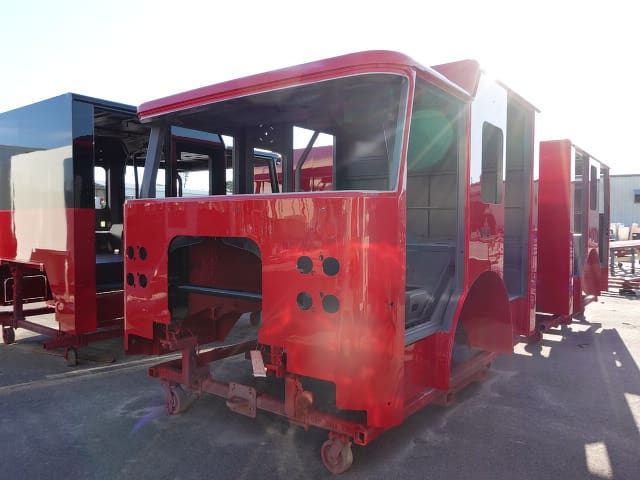

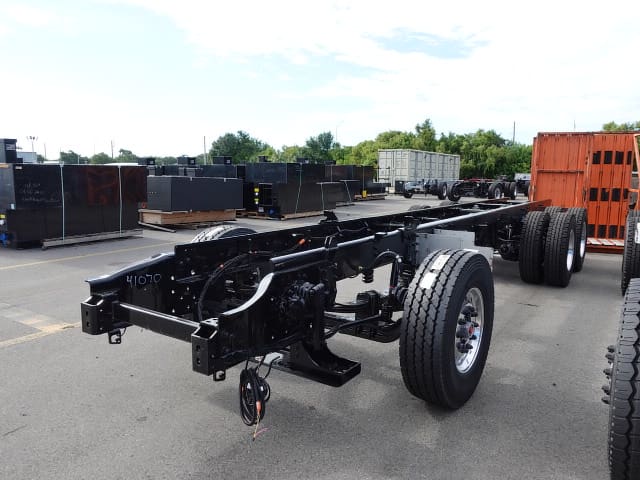

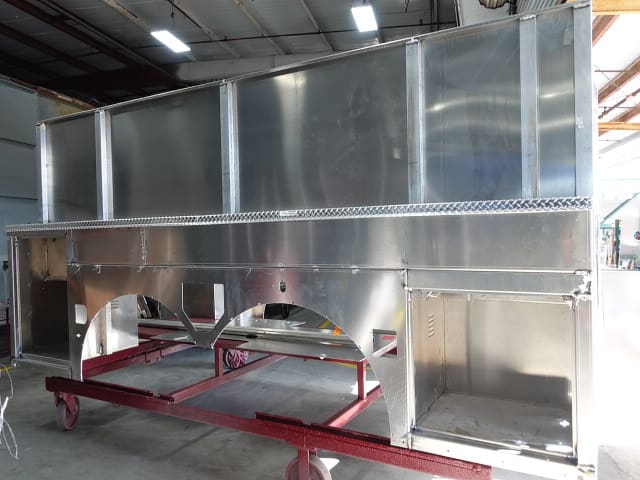

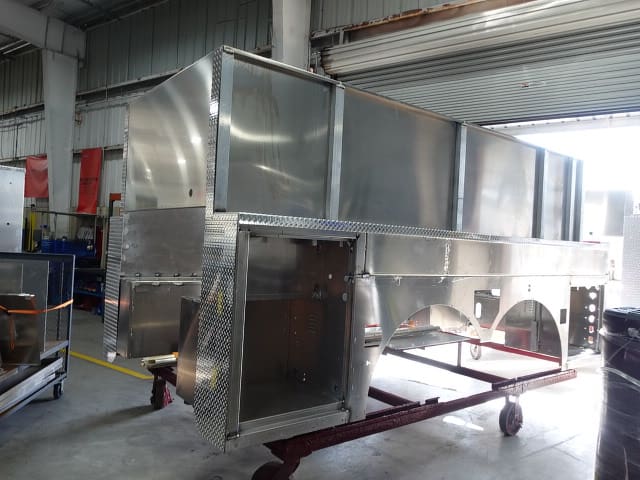

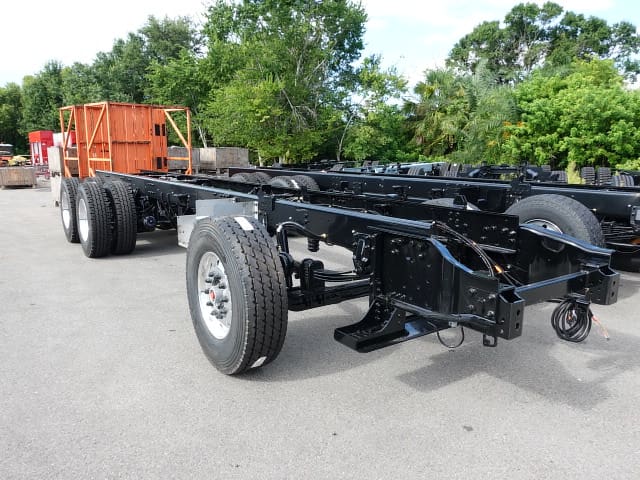

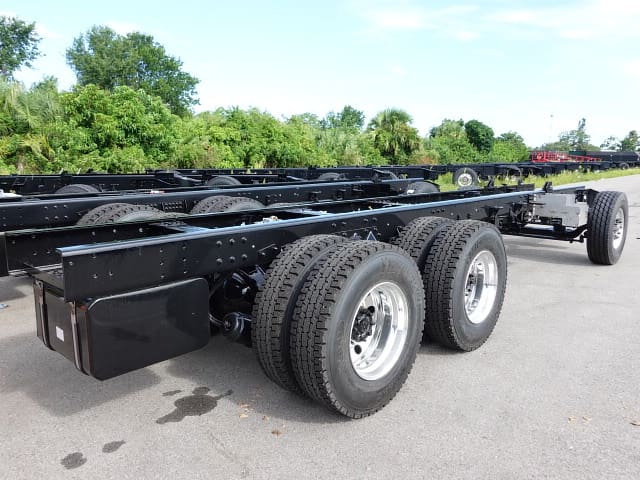

In this report, the cab completed paint, the frame build began, the pump house was painted, and the body completed fabrication and began the paint process.
08-08-25

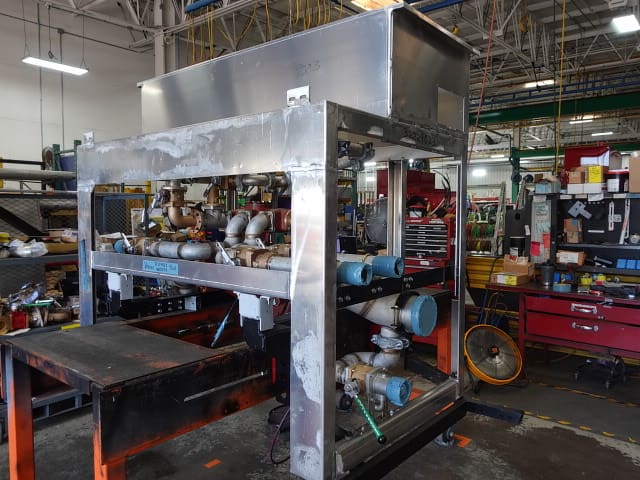

In this report, the cab began the paint process, the pump house continued initial assembly, and the body continued fabrication.
08-01-25

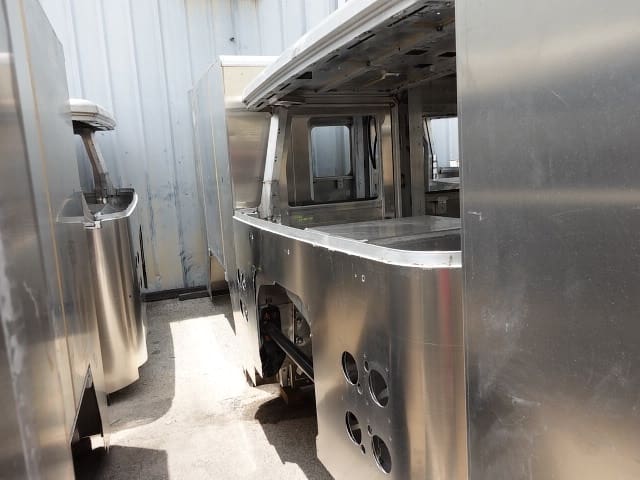

In this report, the cab was staged to begin the paint process, the pump house began initial assembly, and the body continued the fabrication process.

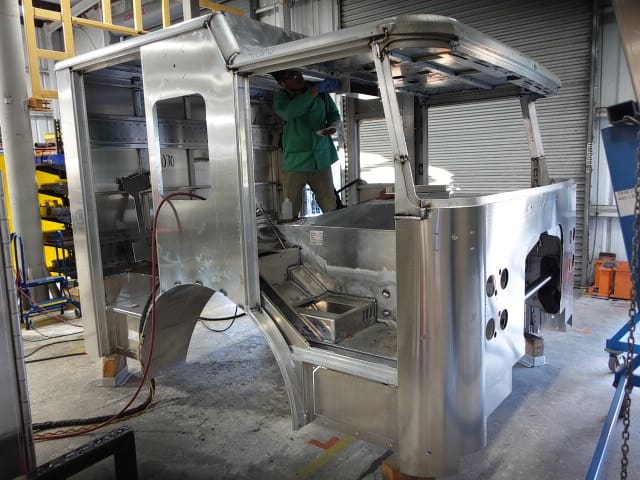

07-25-25

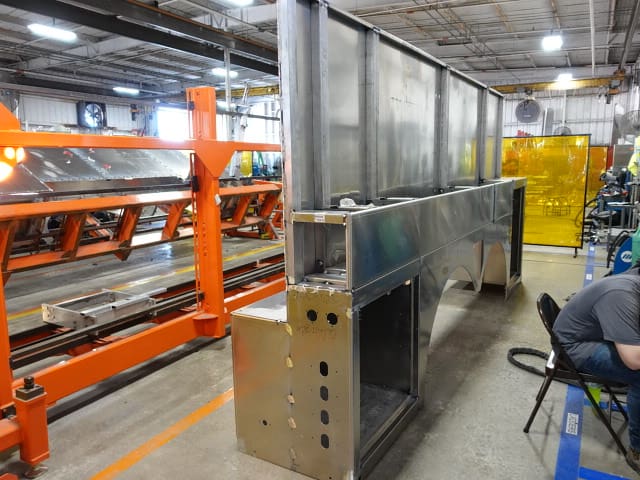

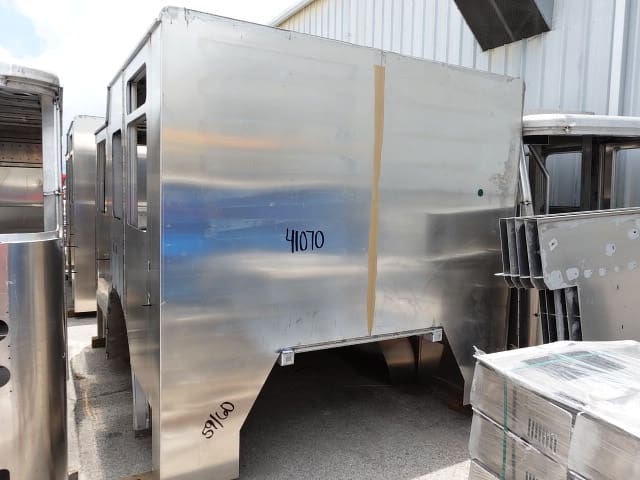

In this report, the cab completed fabrication while the body continued the fabrication process.

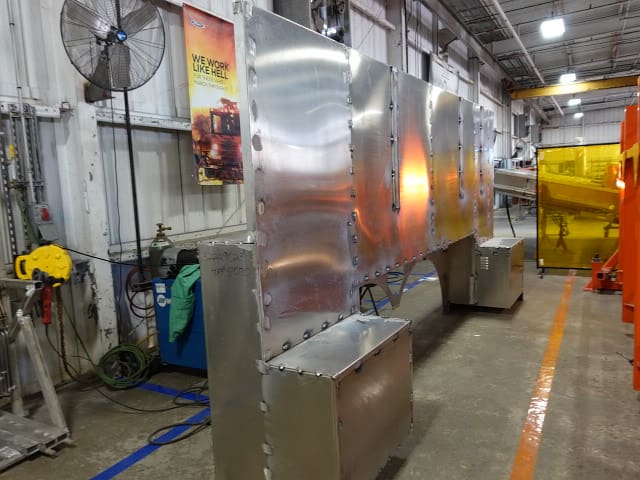

07-18-25

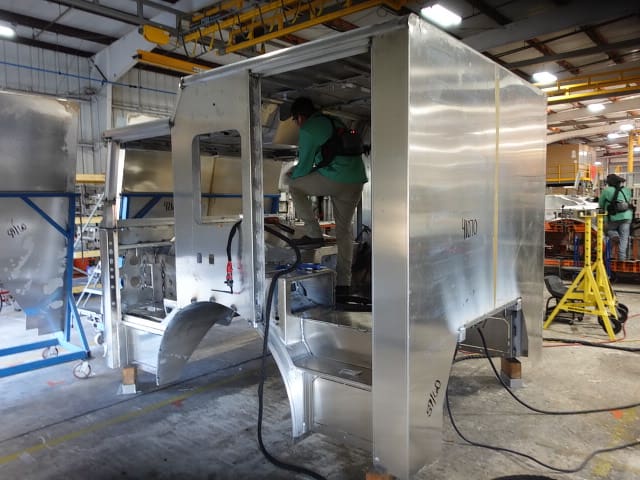

This new Pierce apparatus is now in production! In this report, the began fabrication while the body panels began fabrication.
