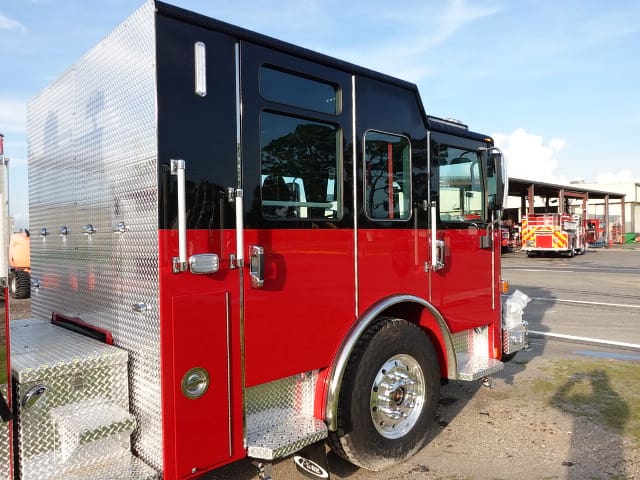

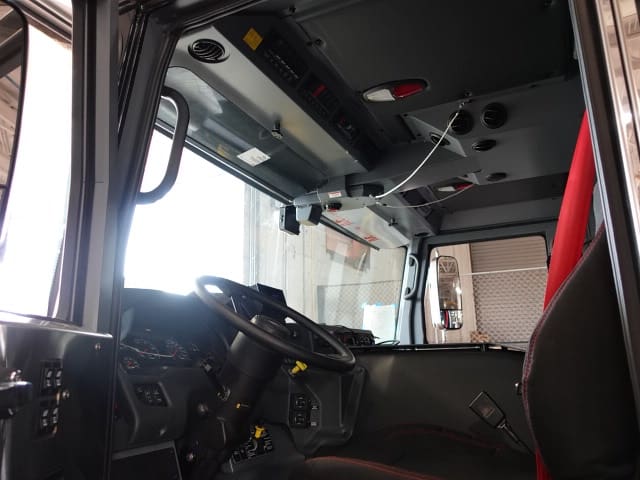

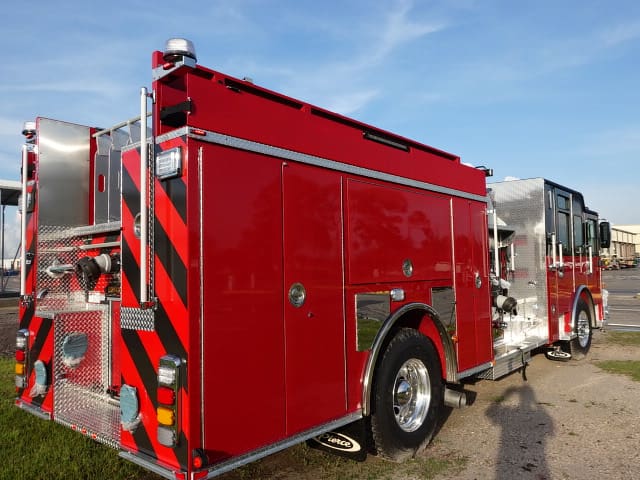

07-18-25

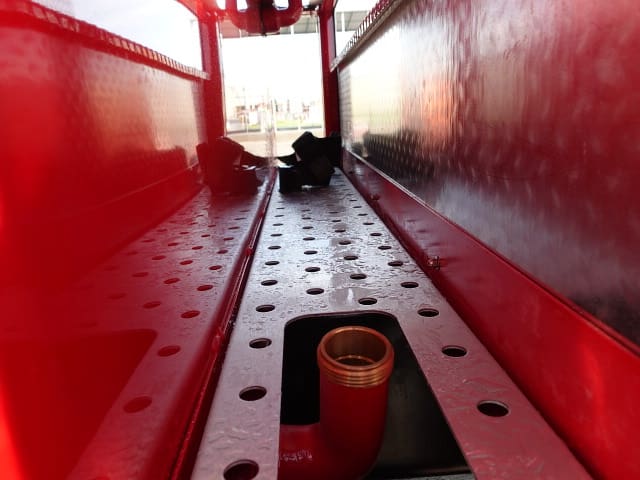

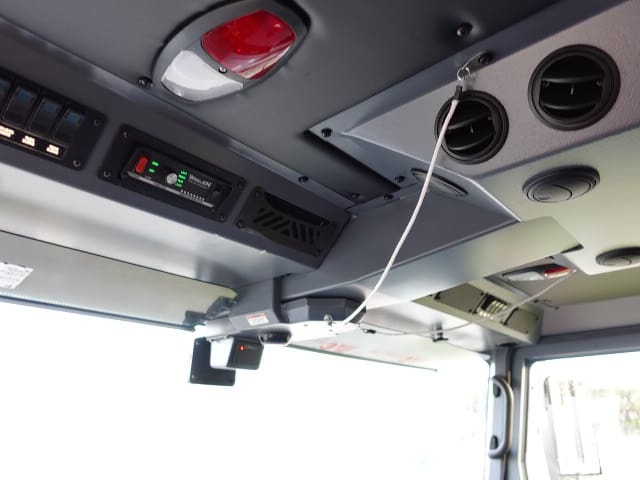

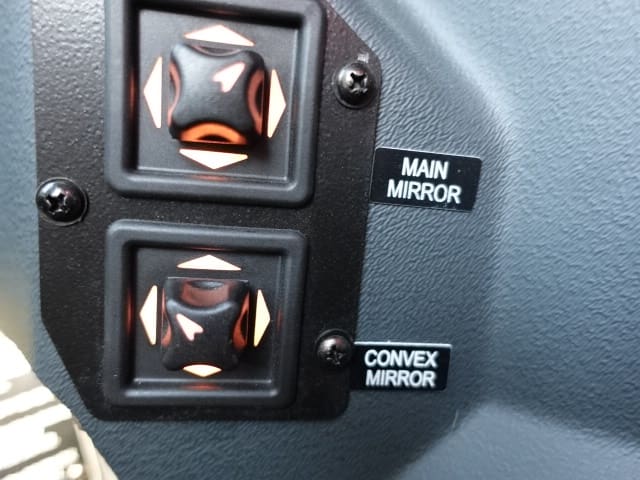

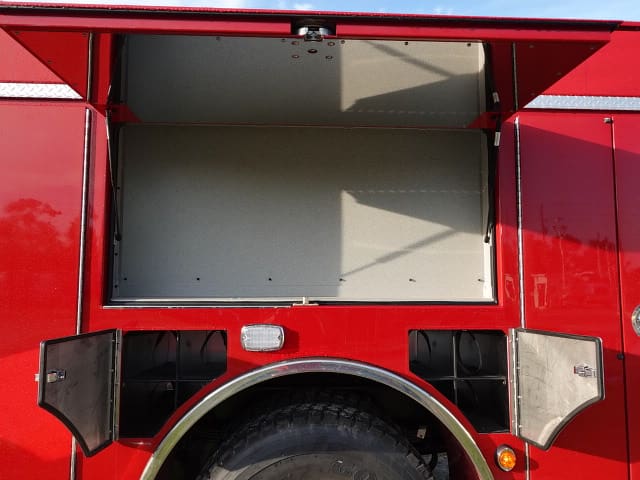

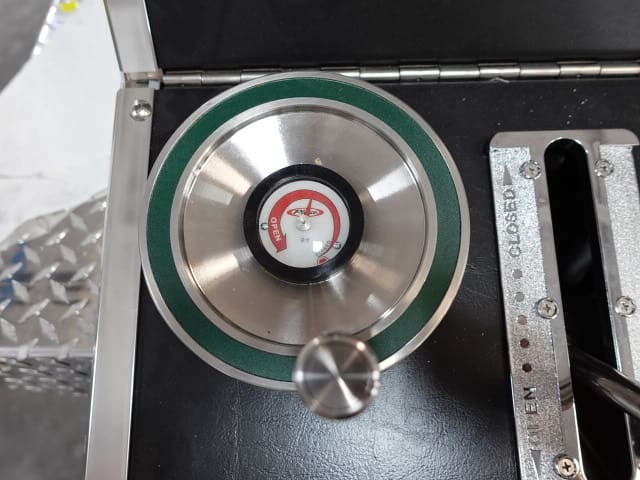

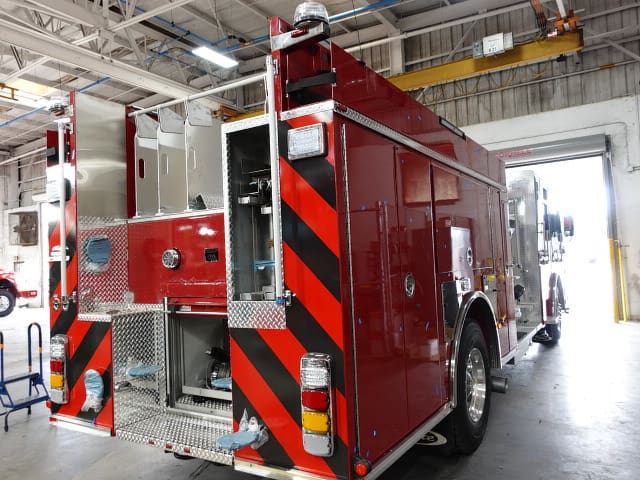

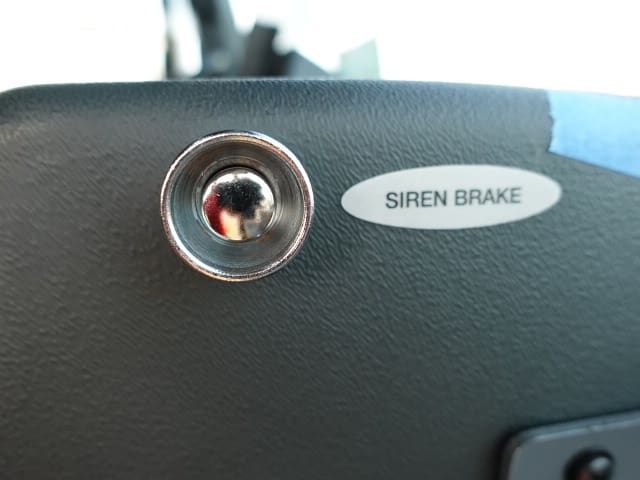

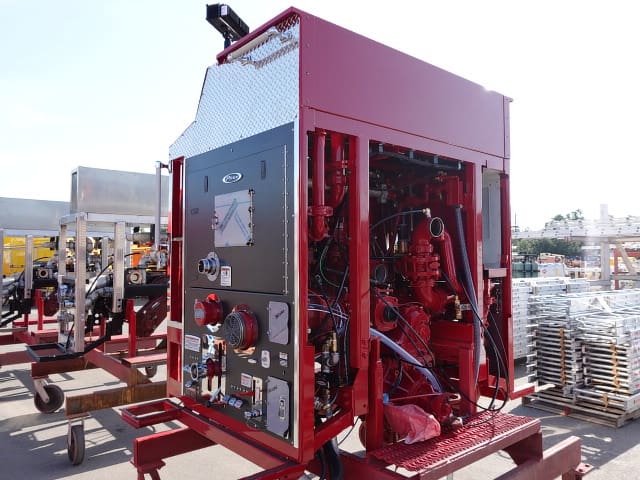

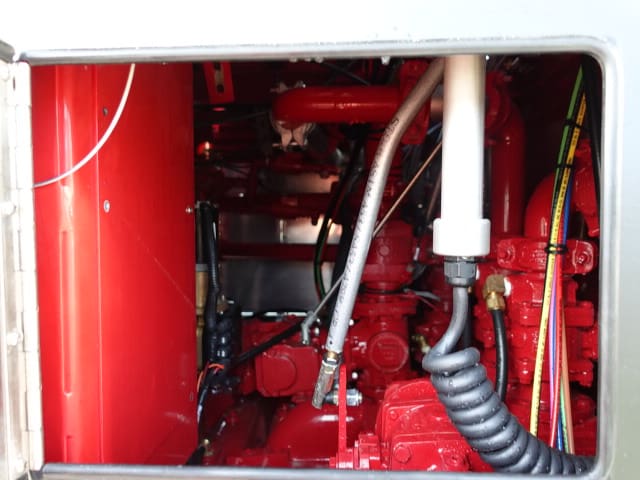

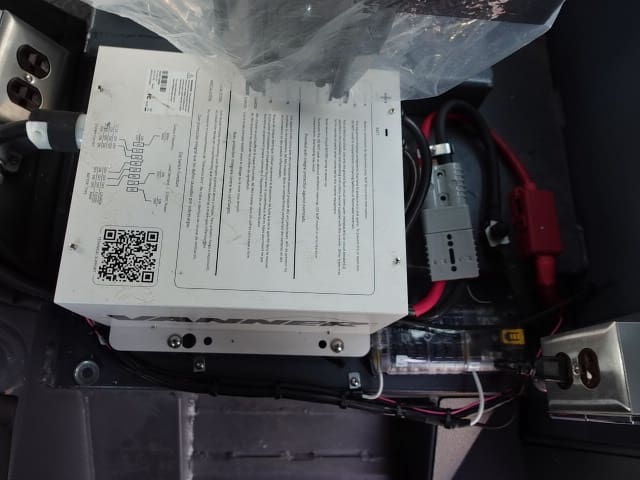

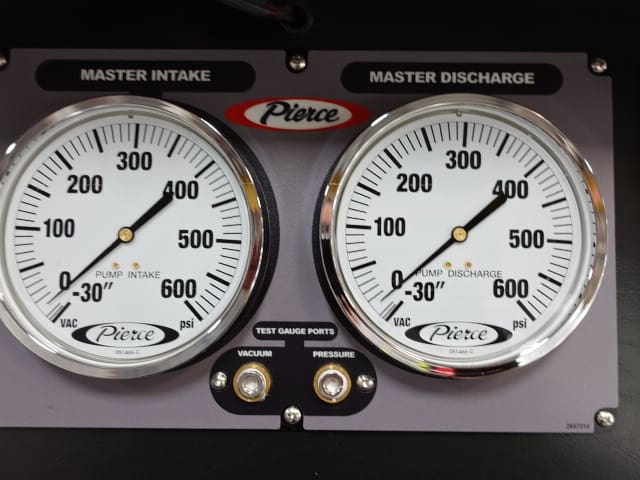

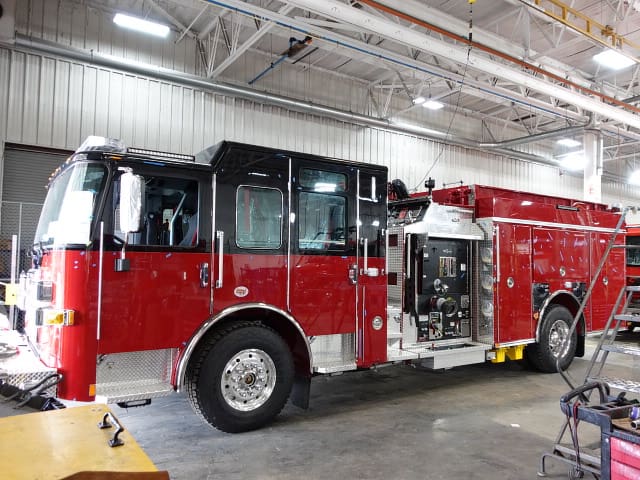

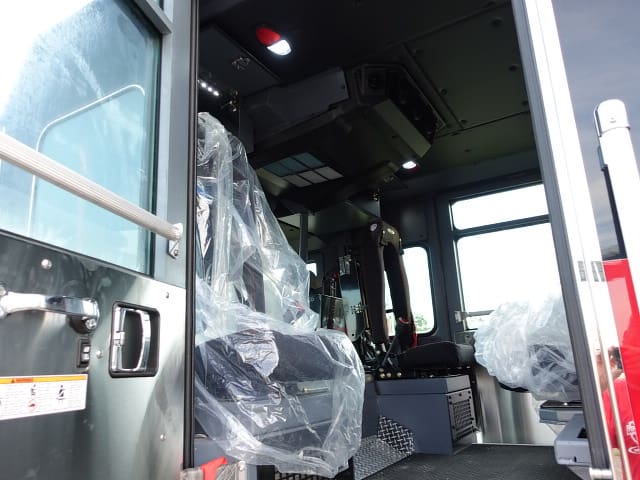

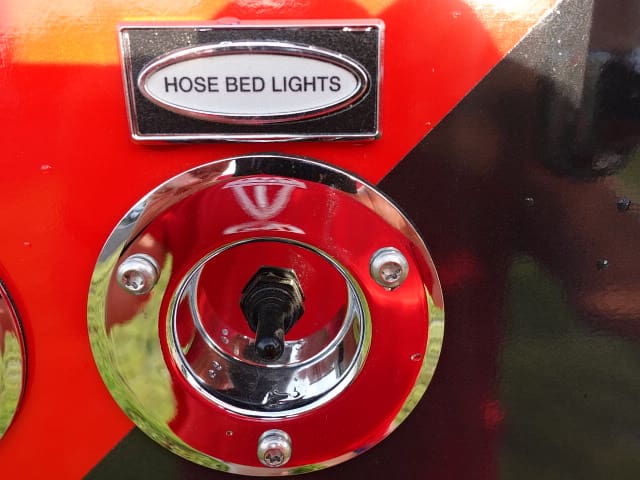

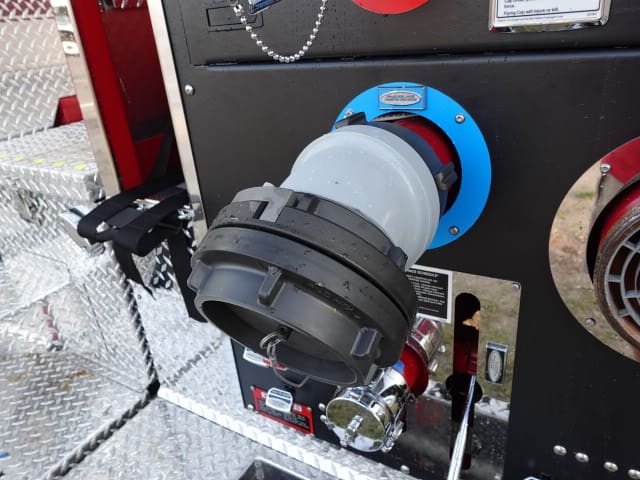

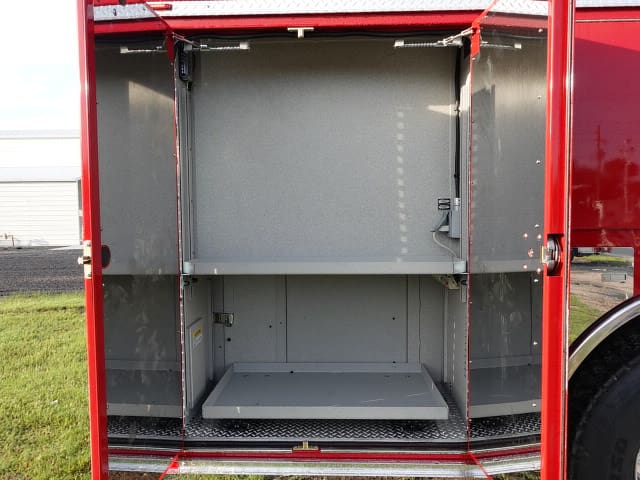

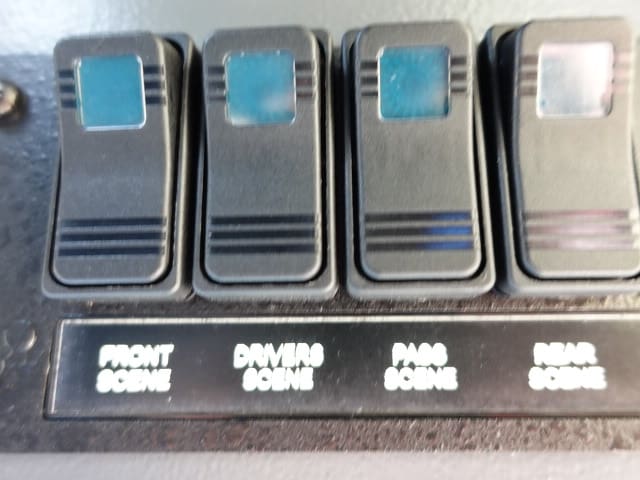

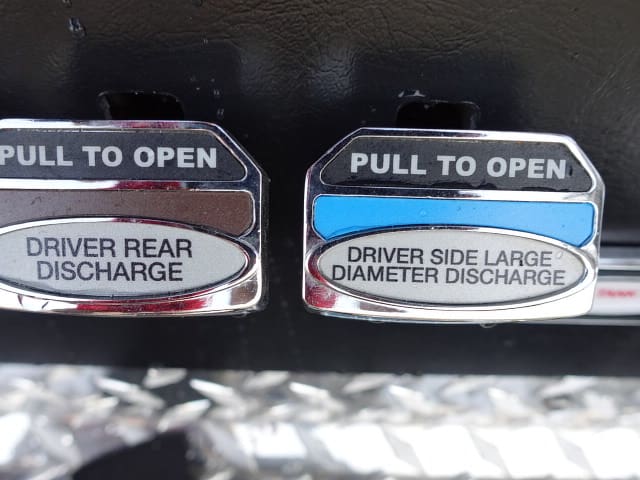

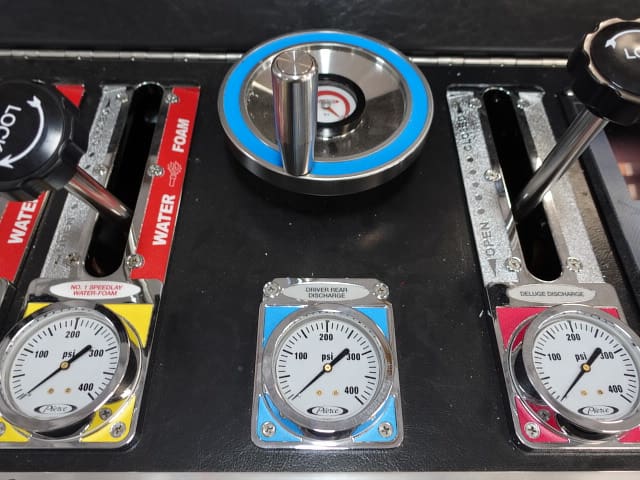

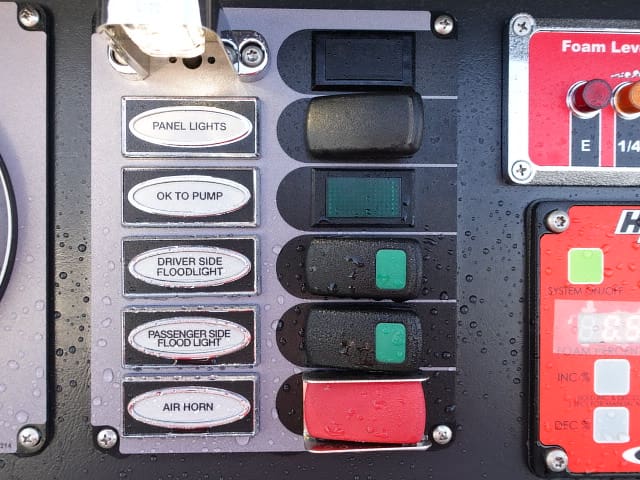

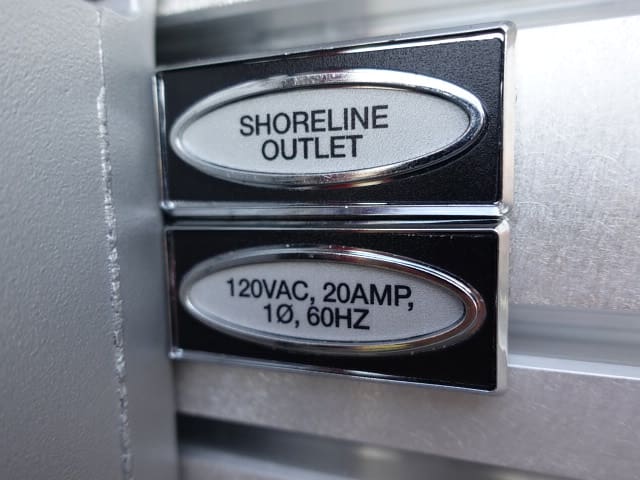

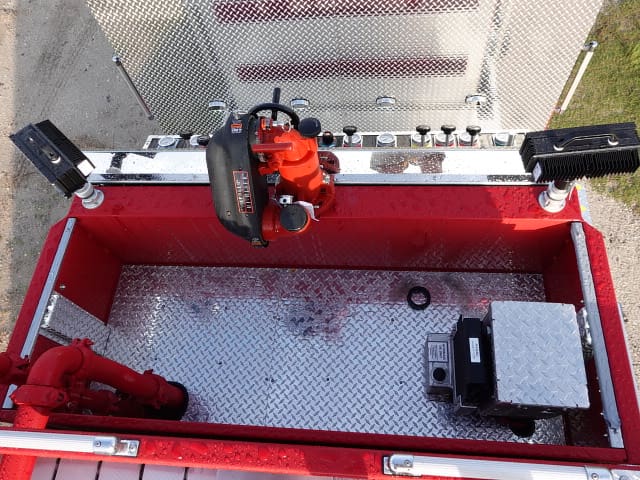

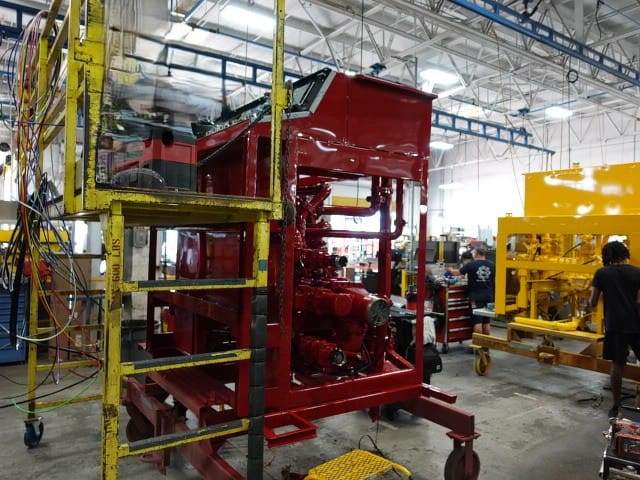

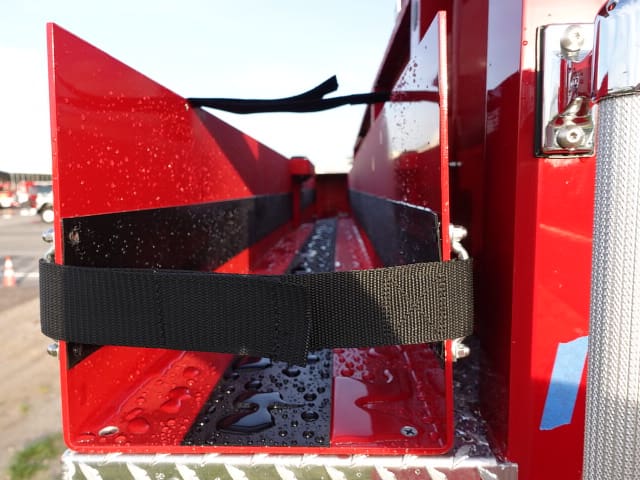

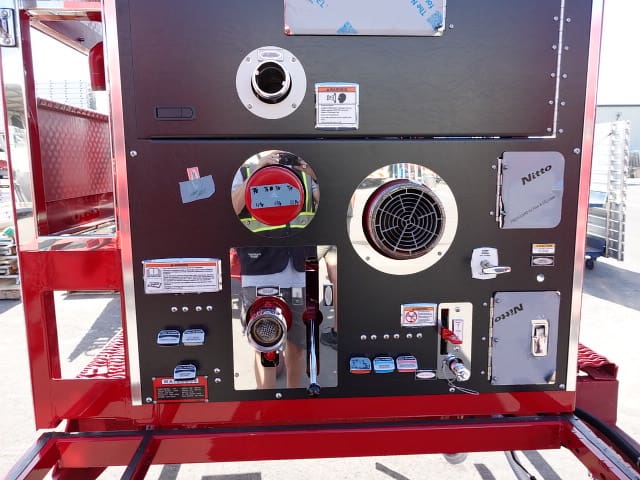

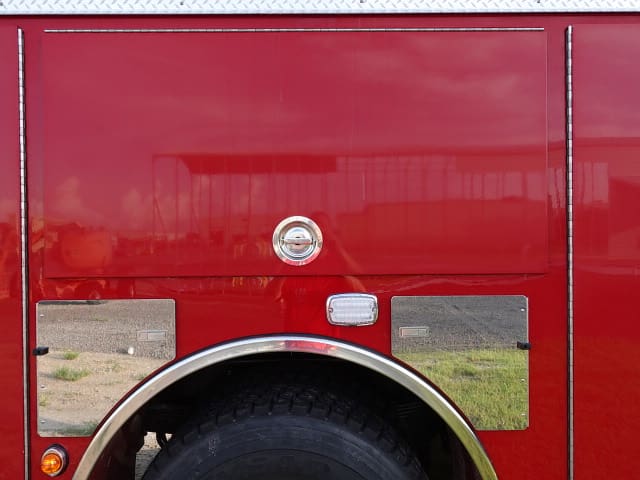

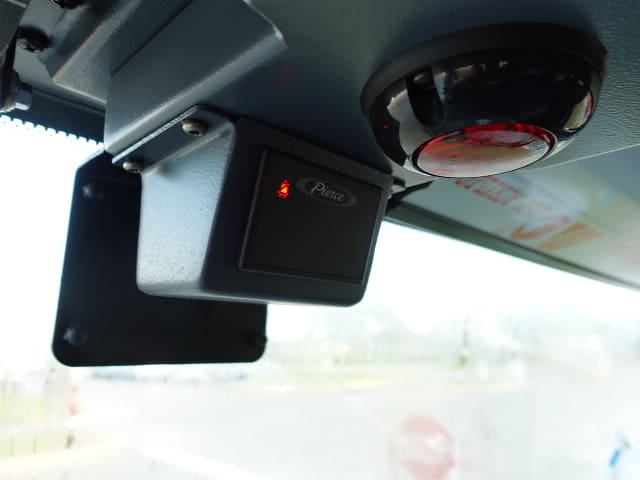

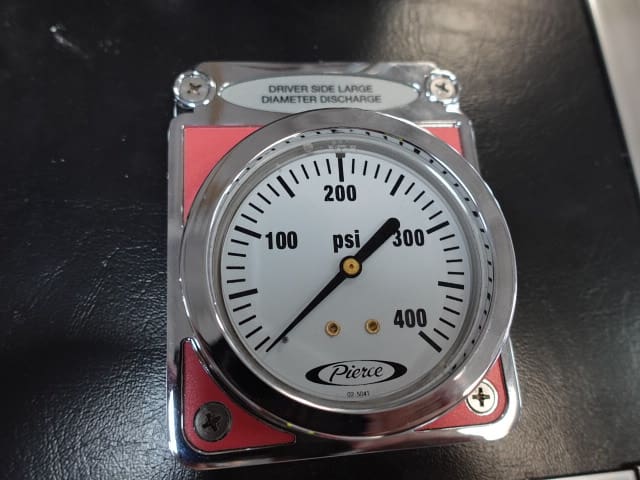

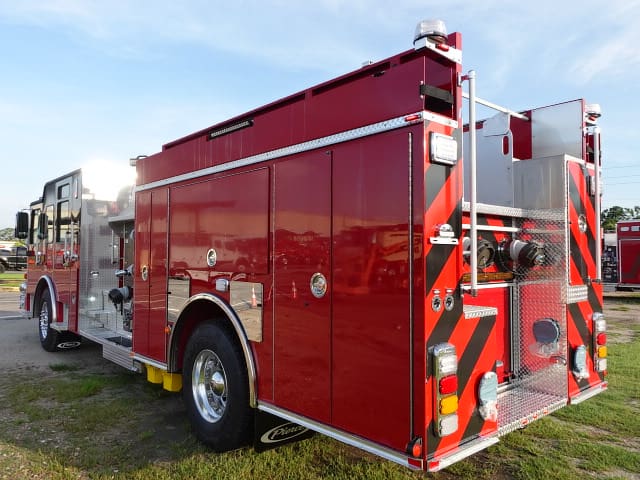

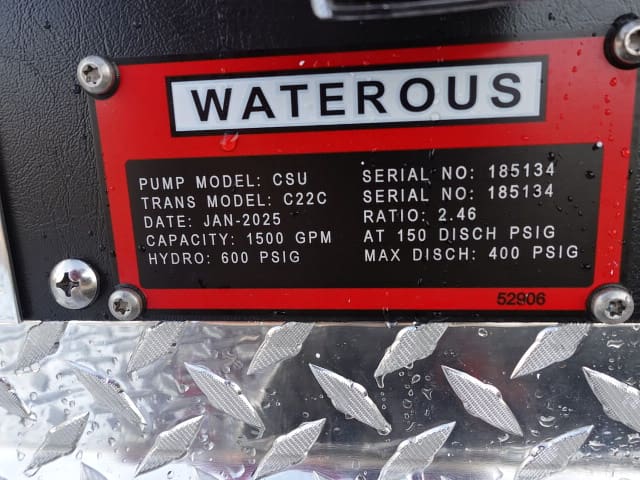

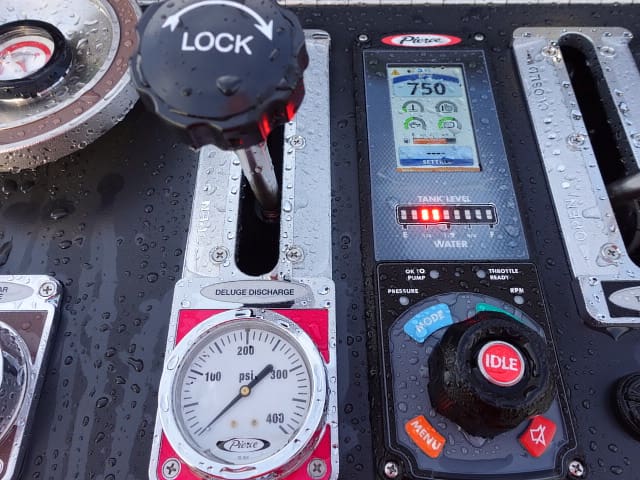

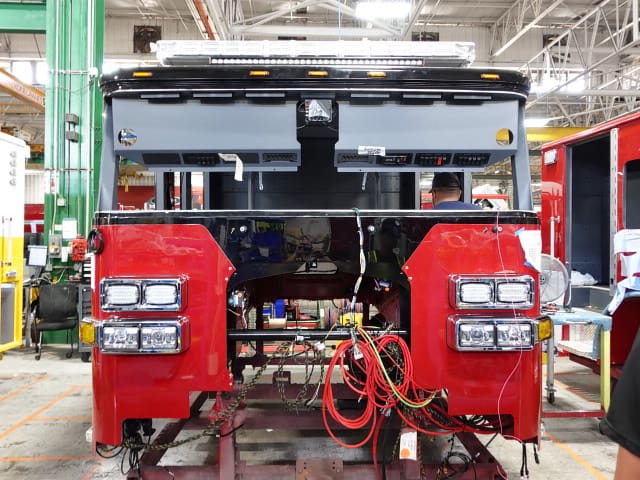

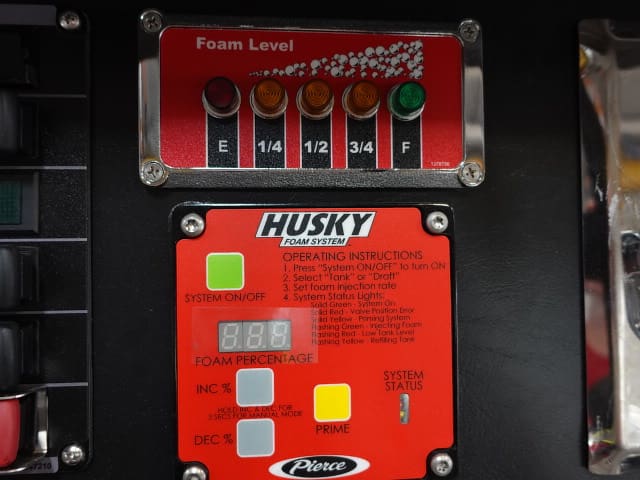

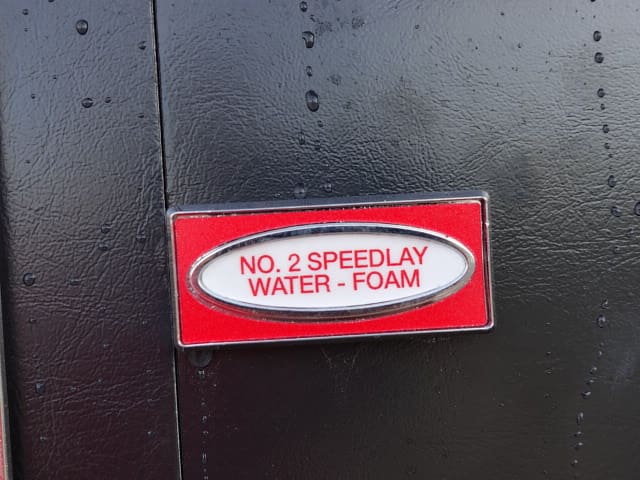

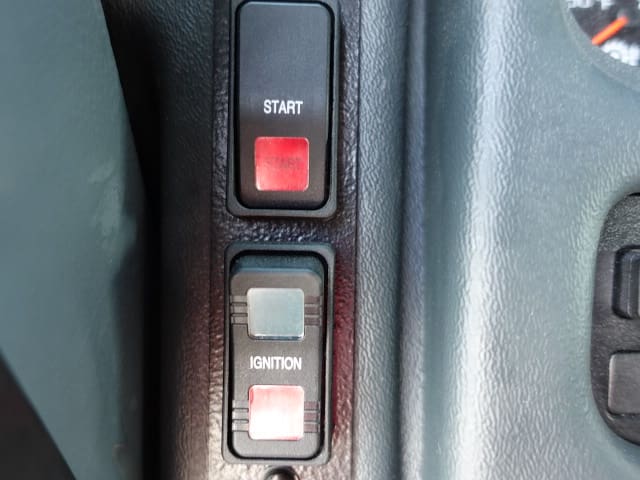

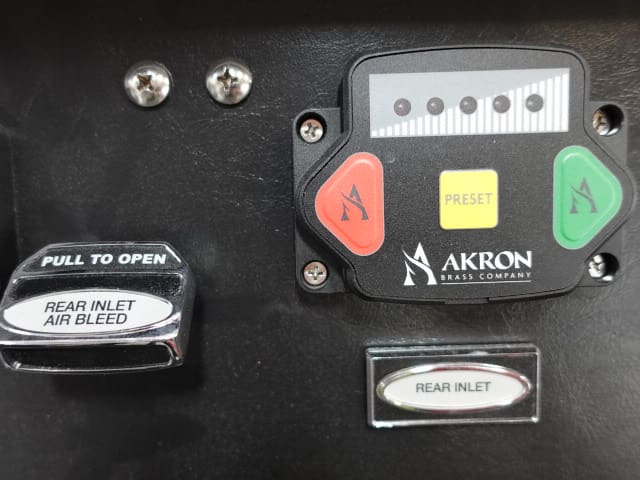

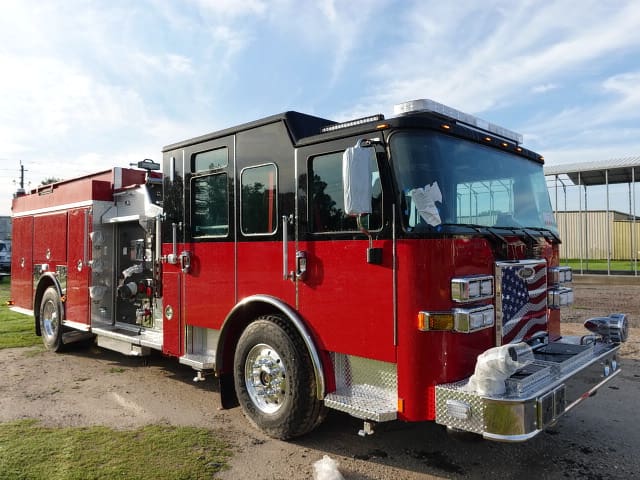

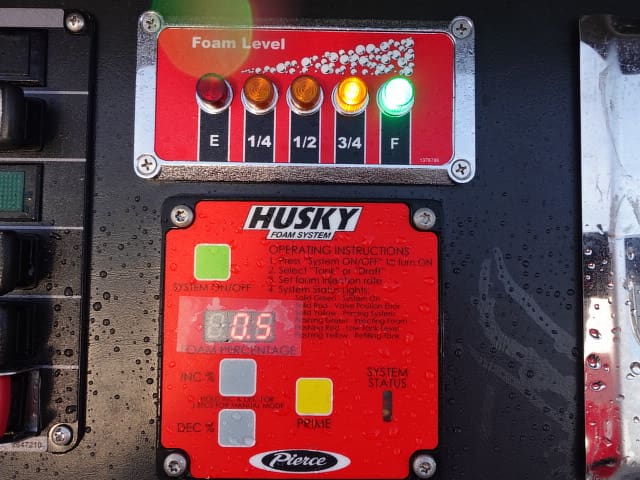

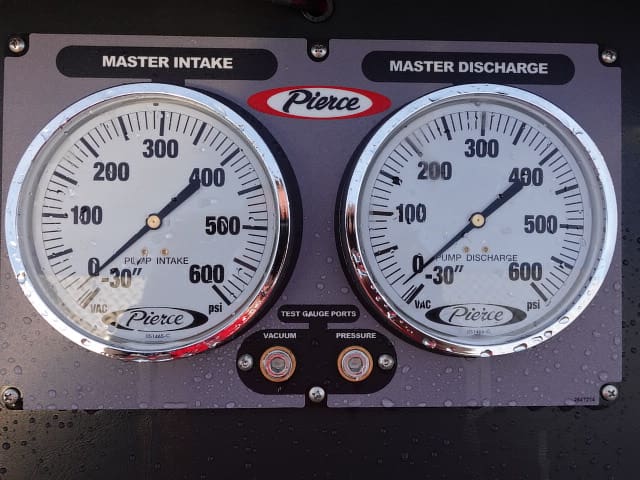

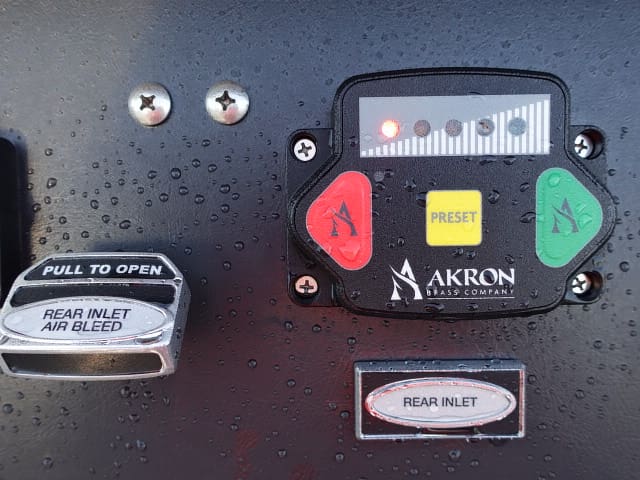

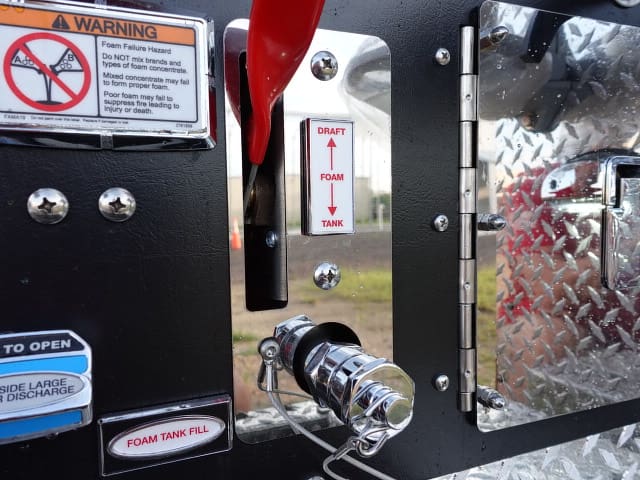

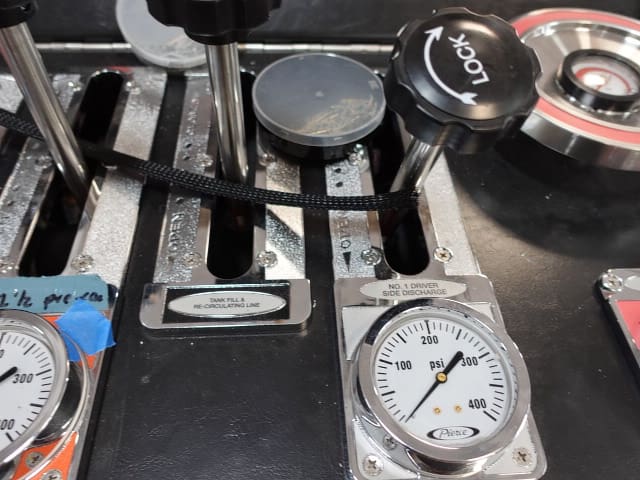

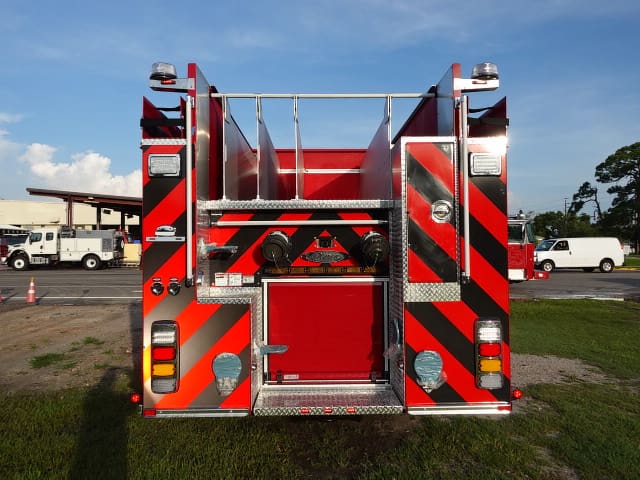

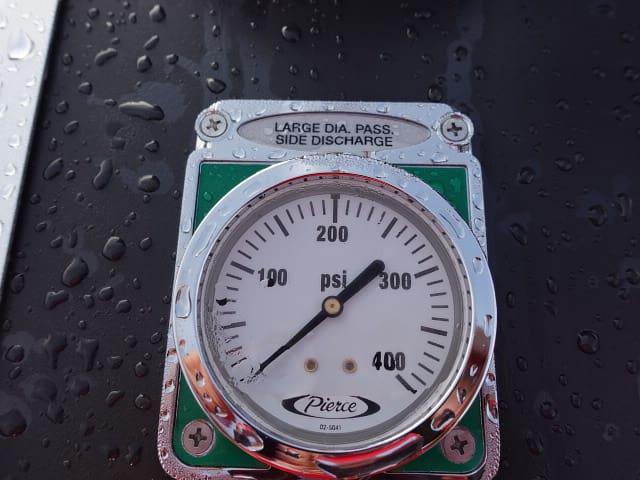

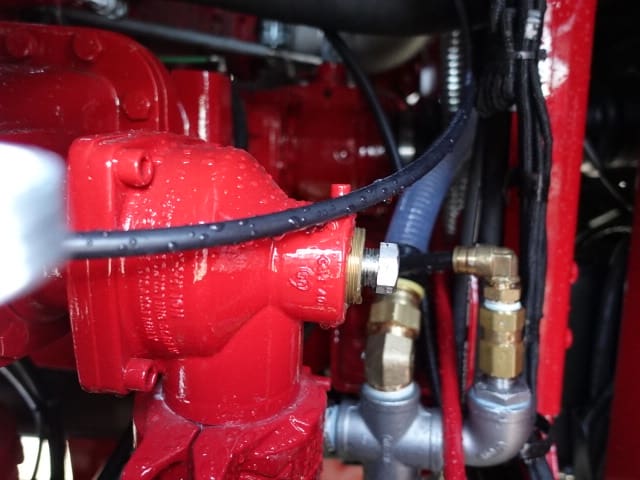

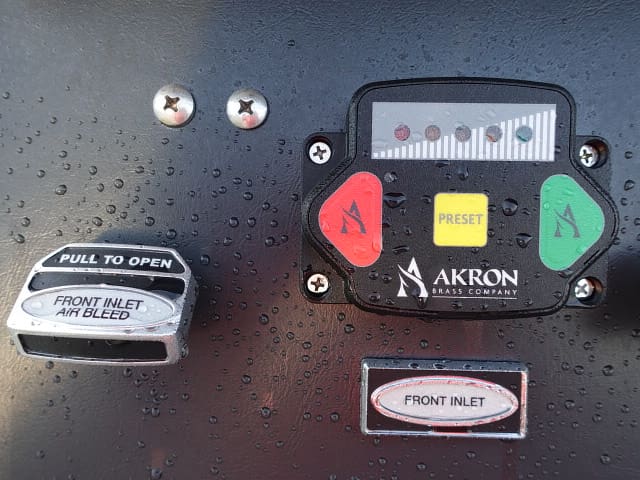

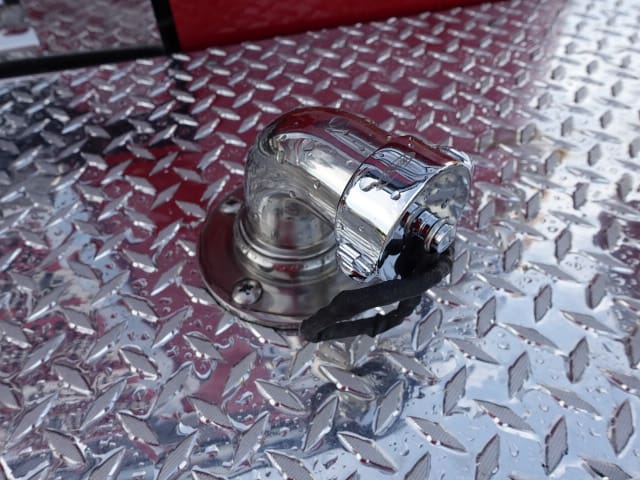

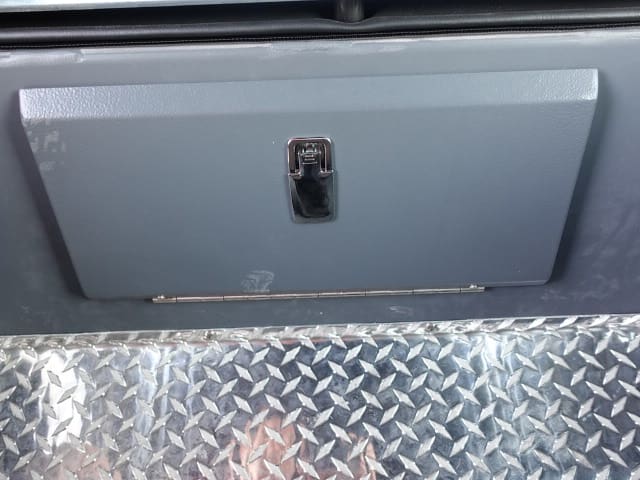

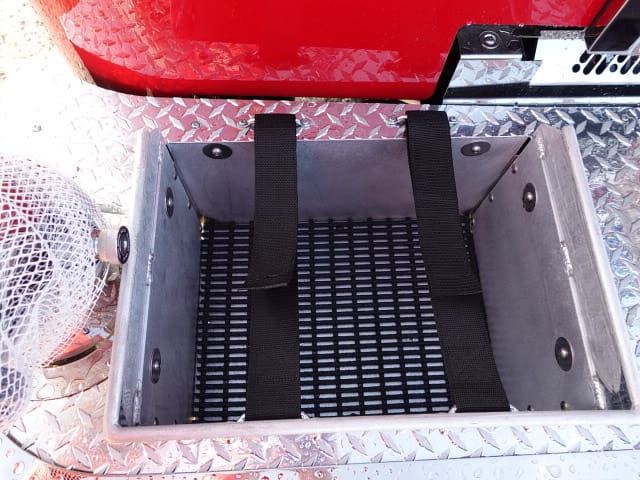

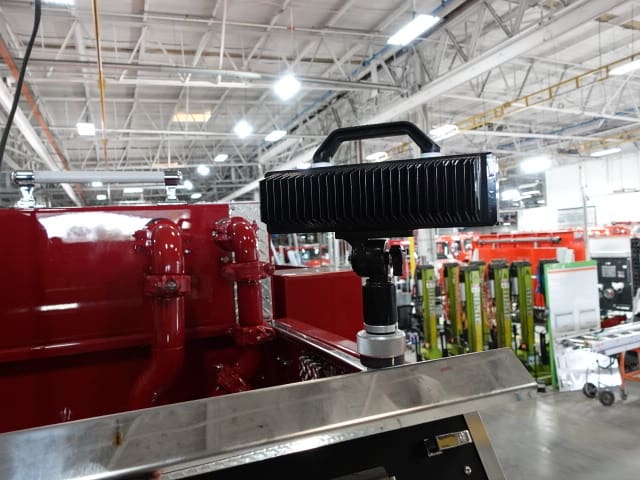

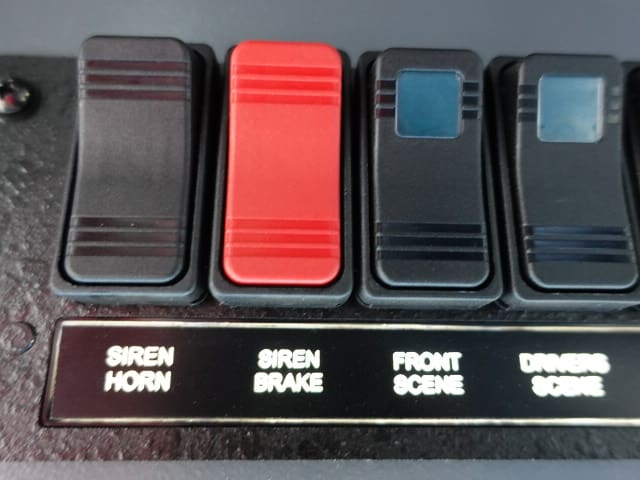

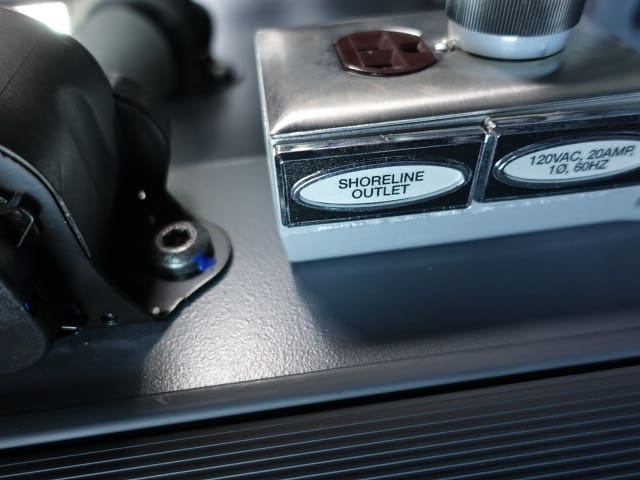

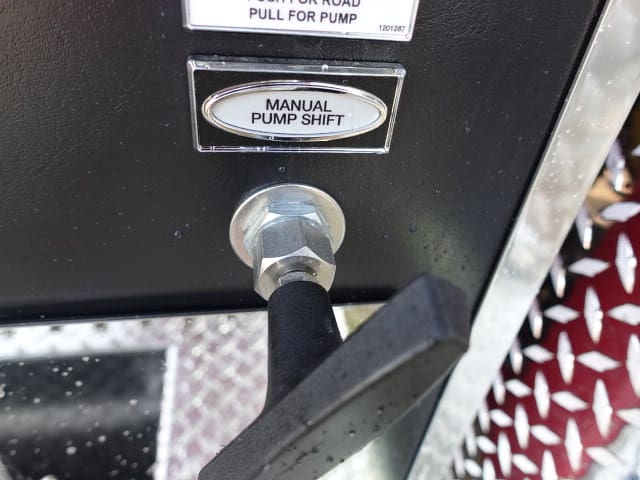

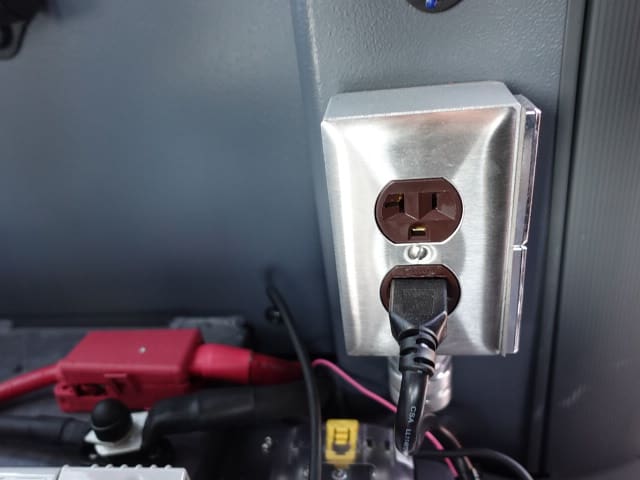

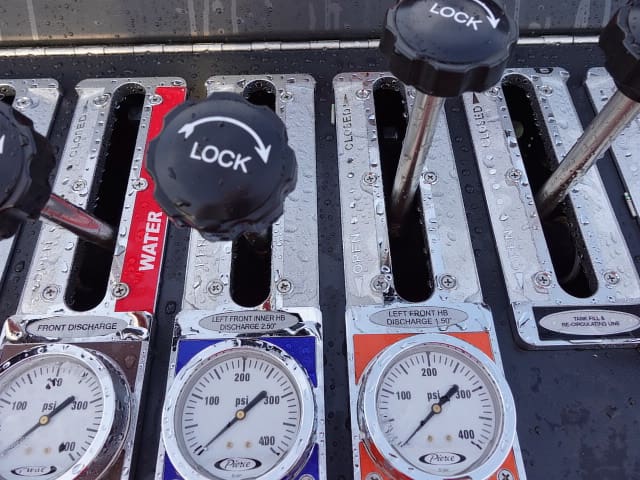

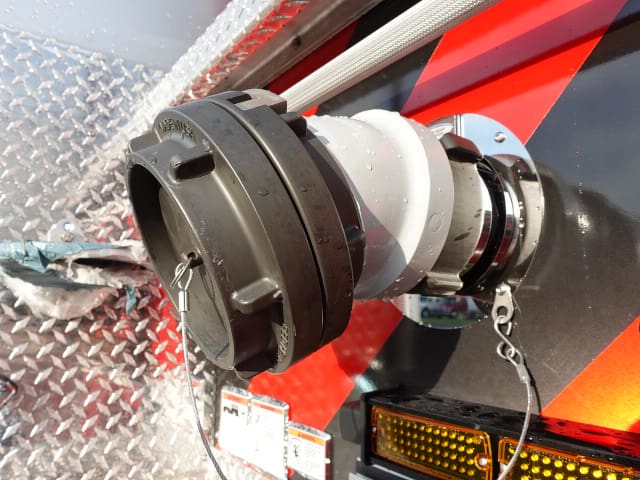

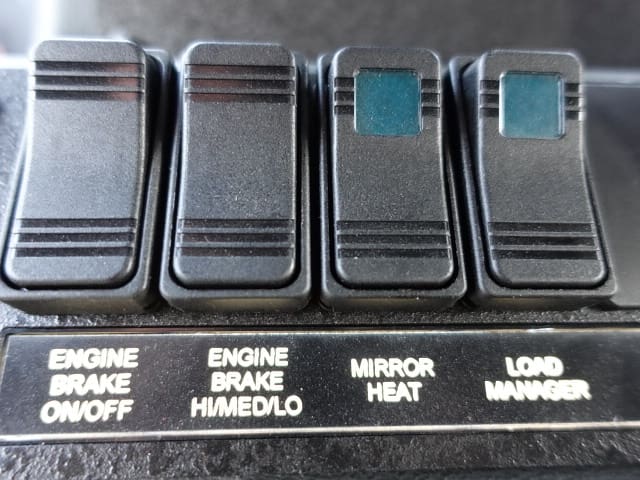

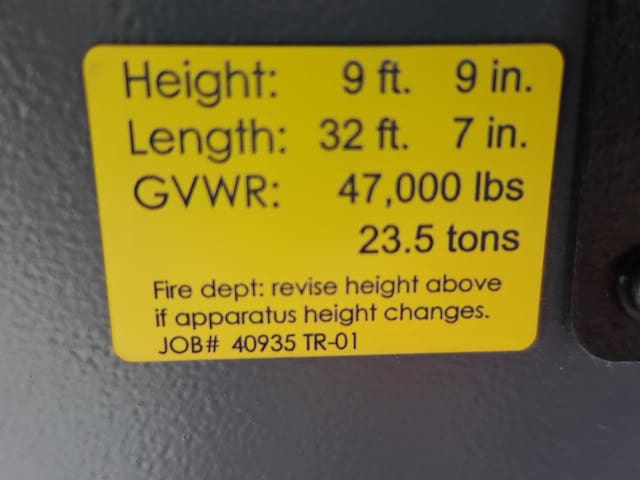

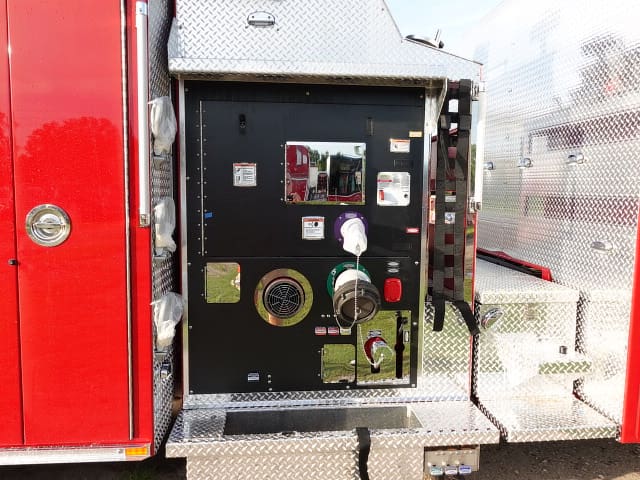

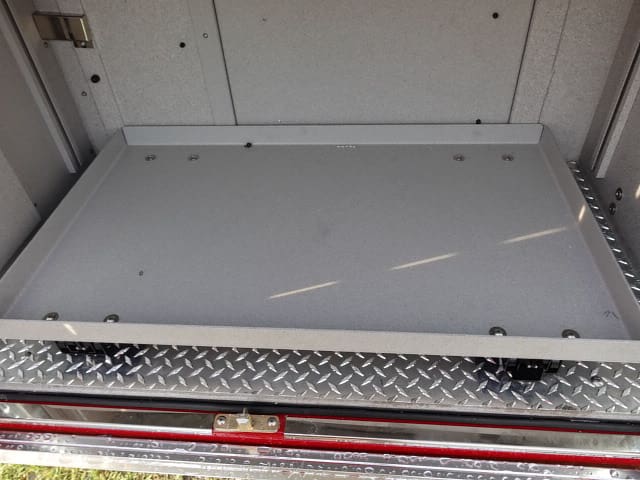

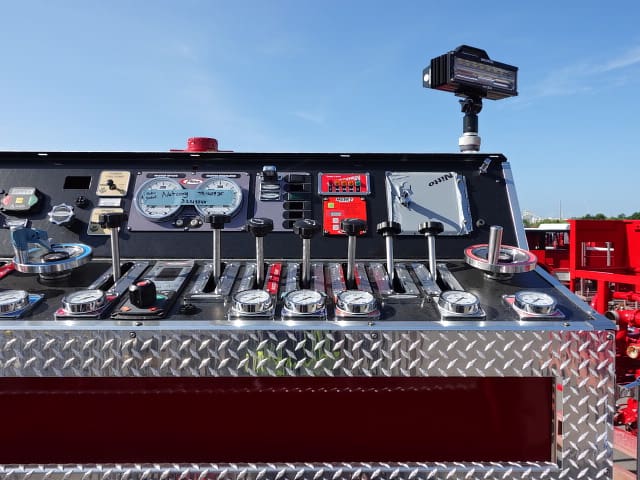

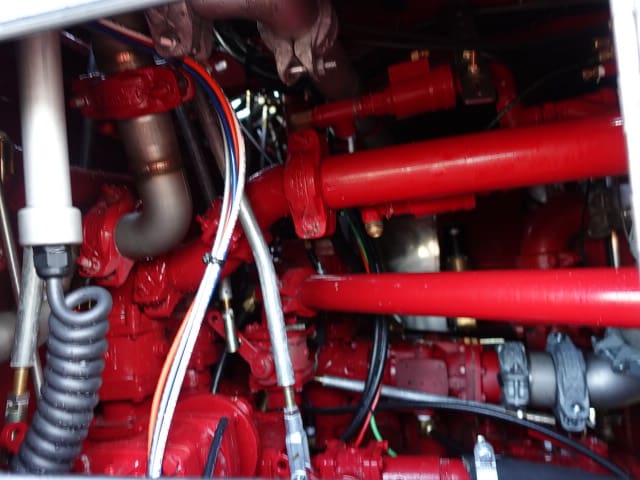

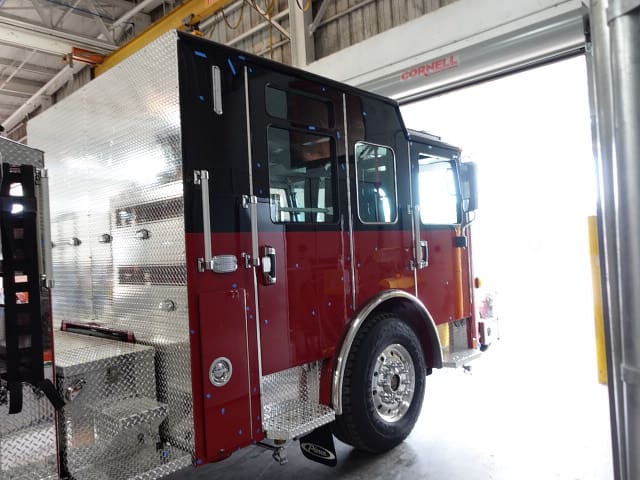

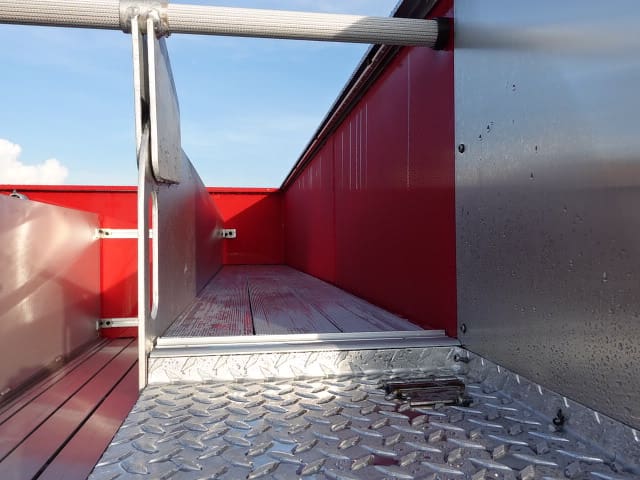

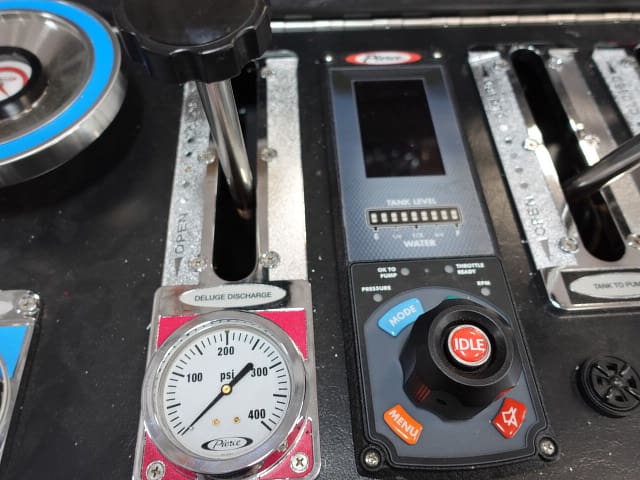

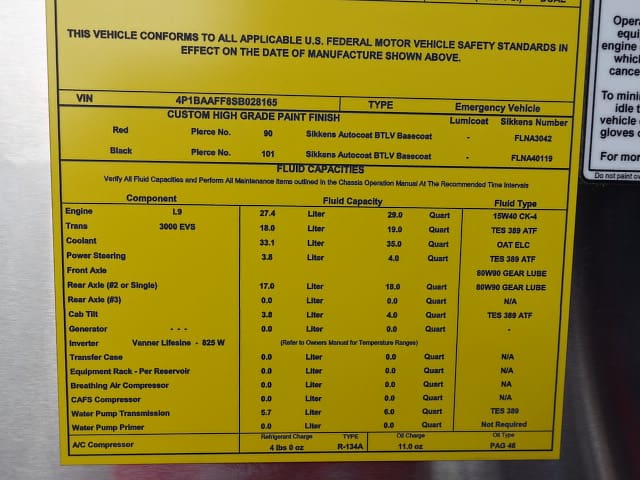

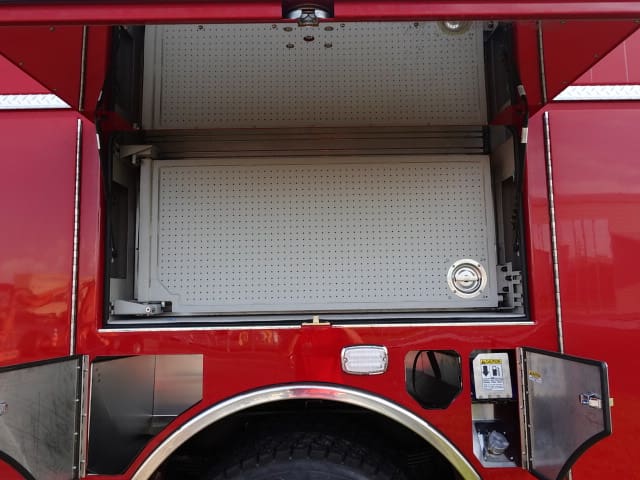

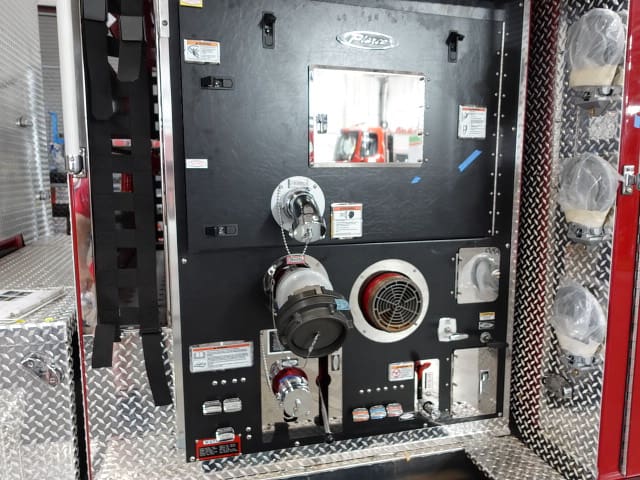

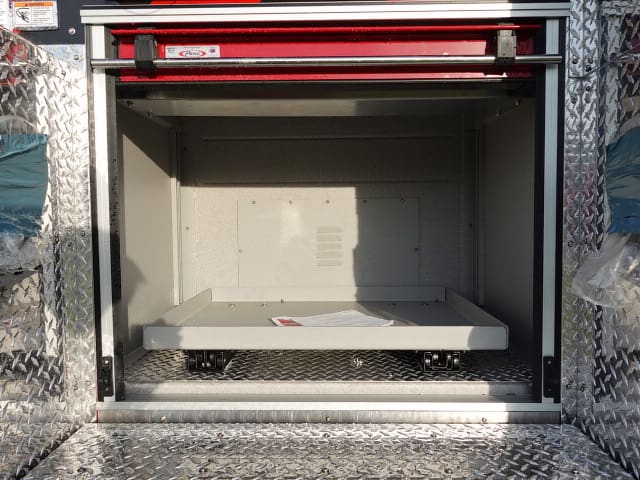

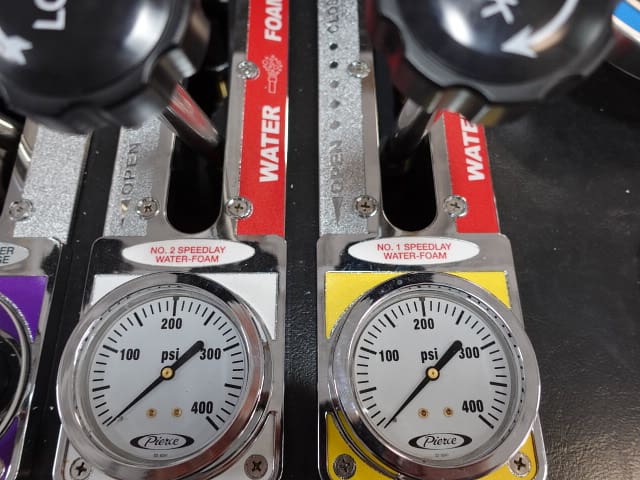

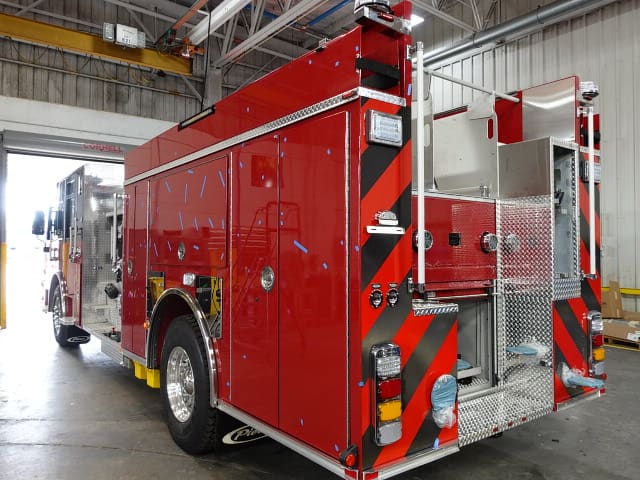

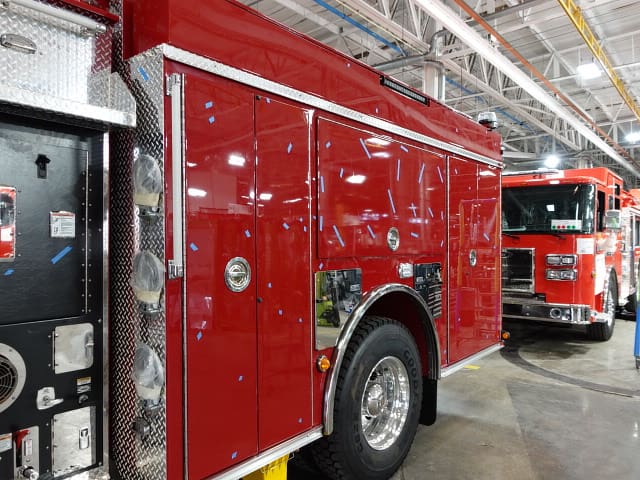

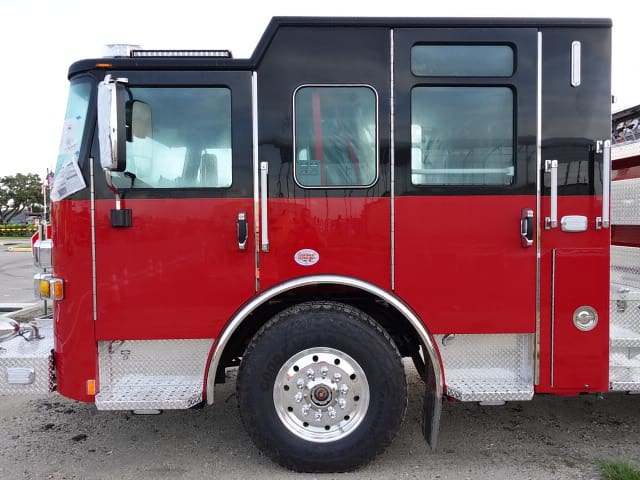

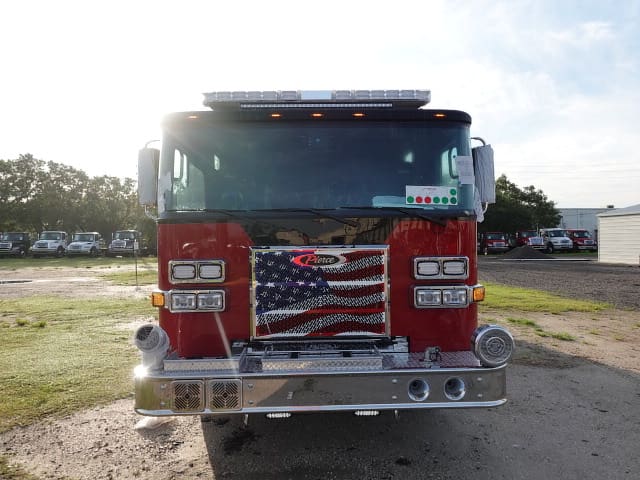

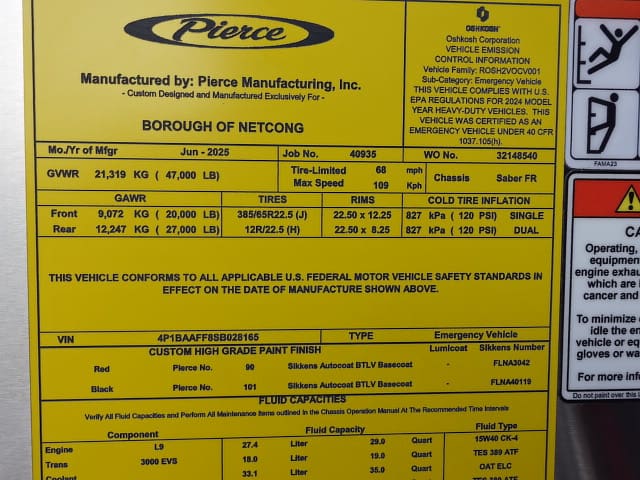

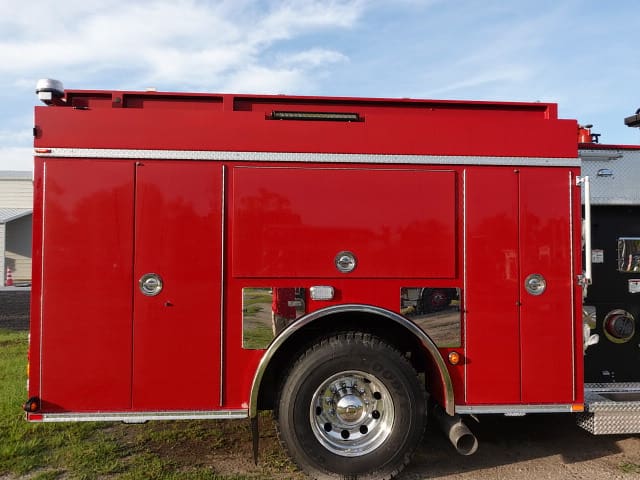

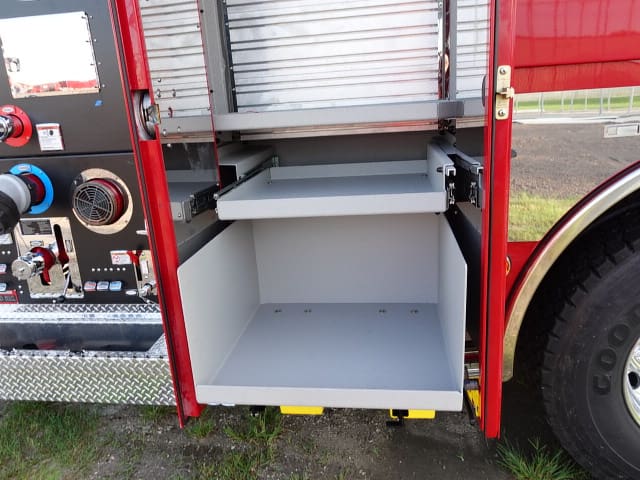

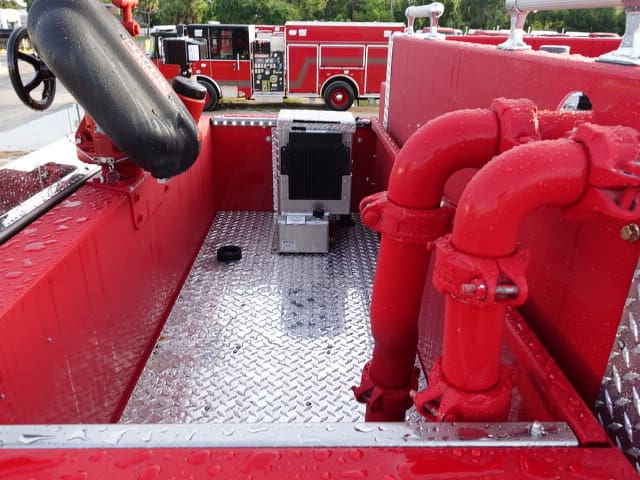

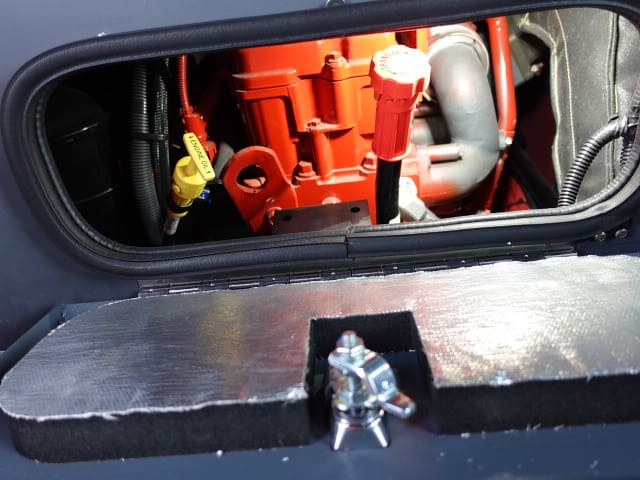

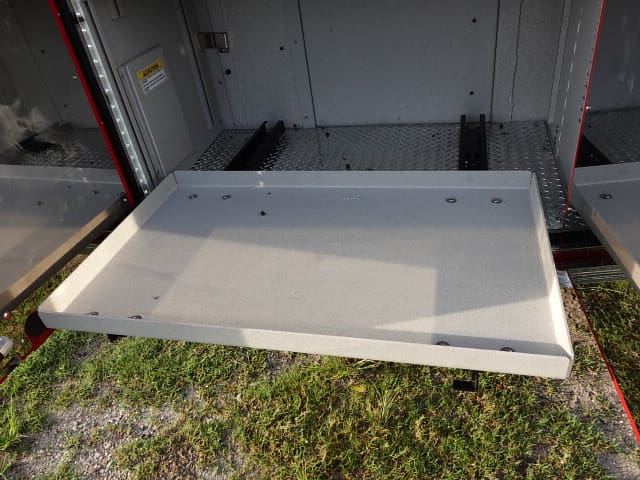

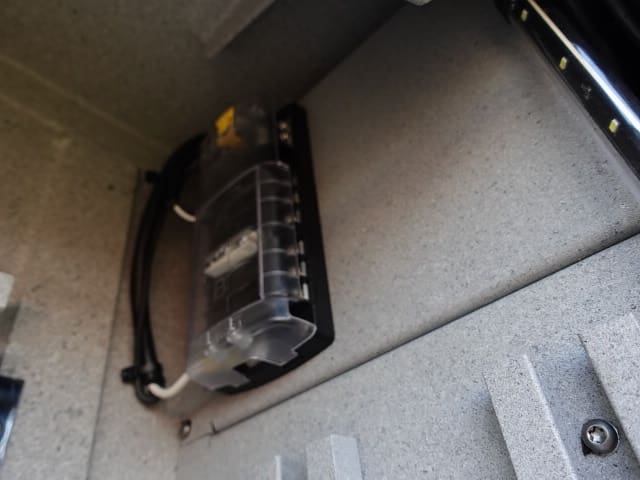

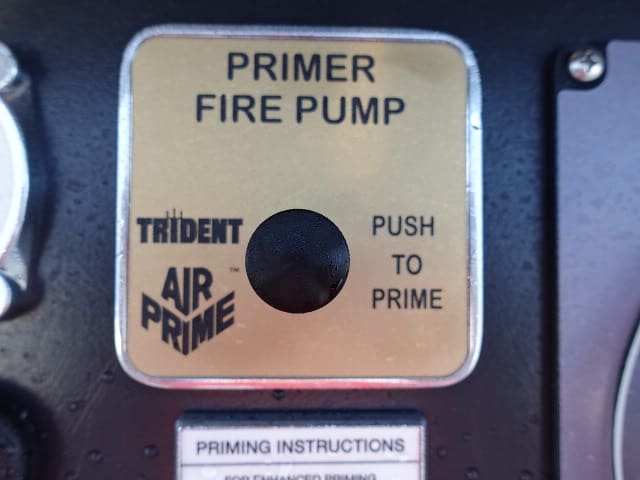

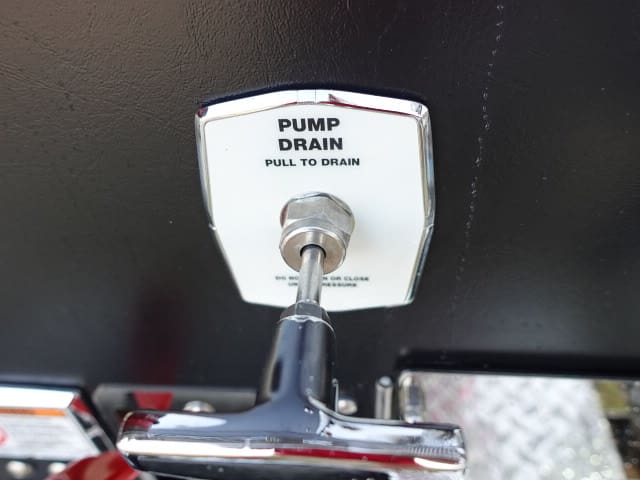

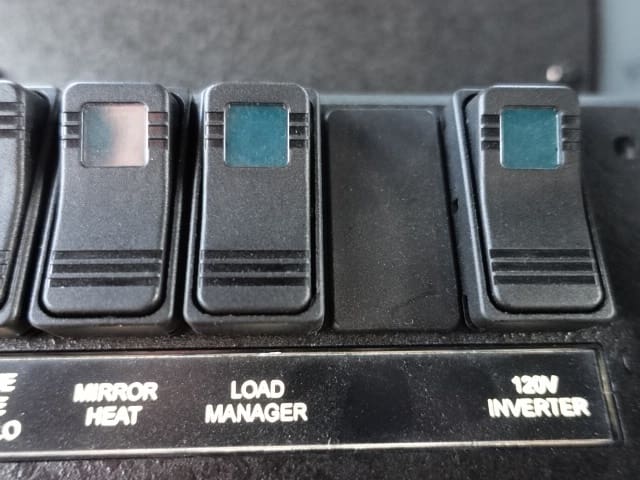

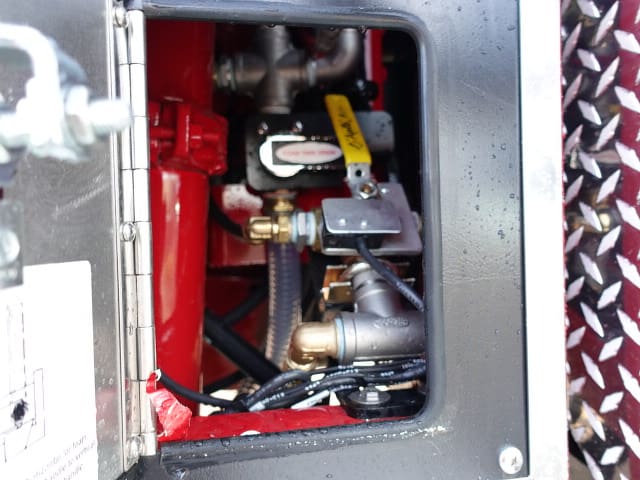

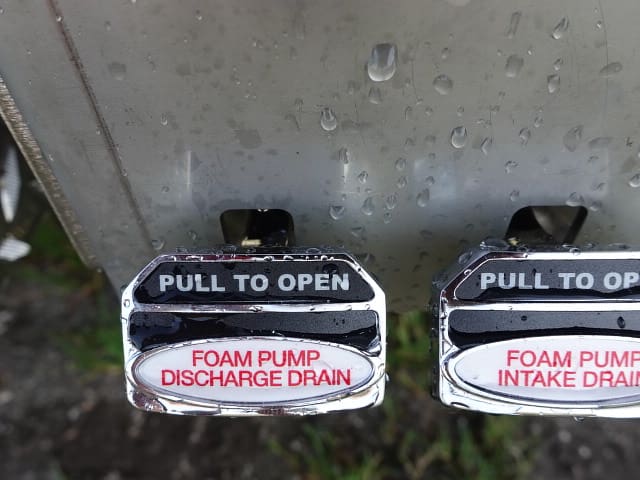

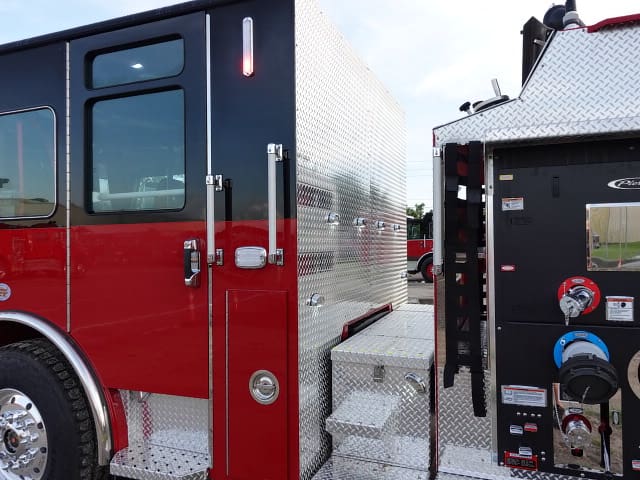

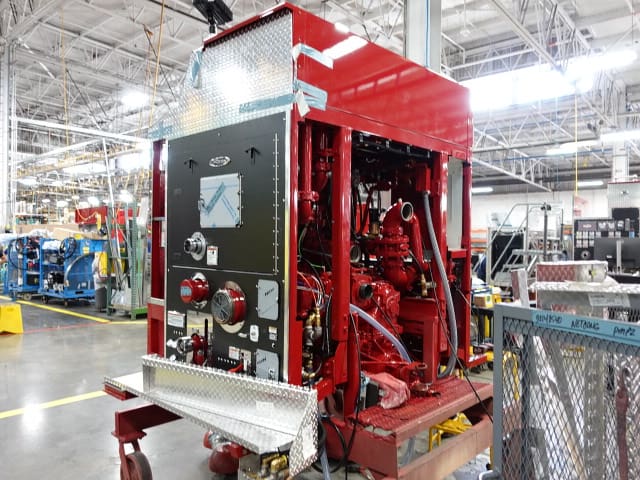

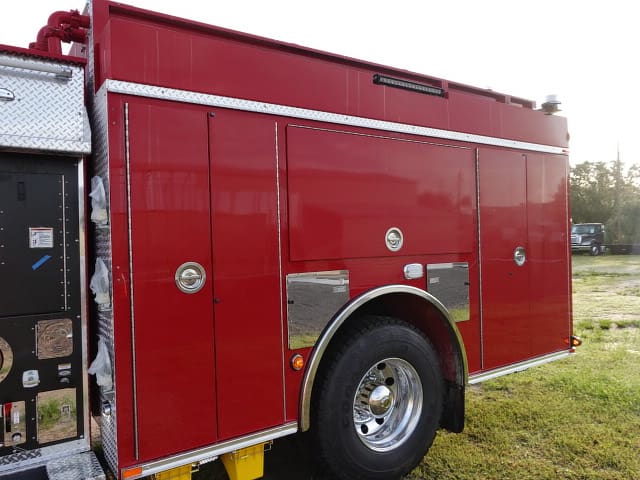

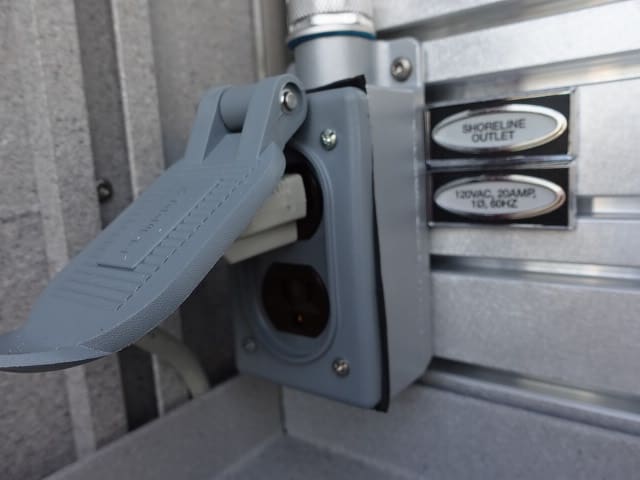

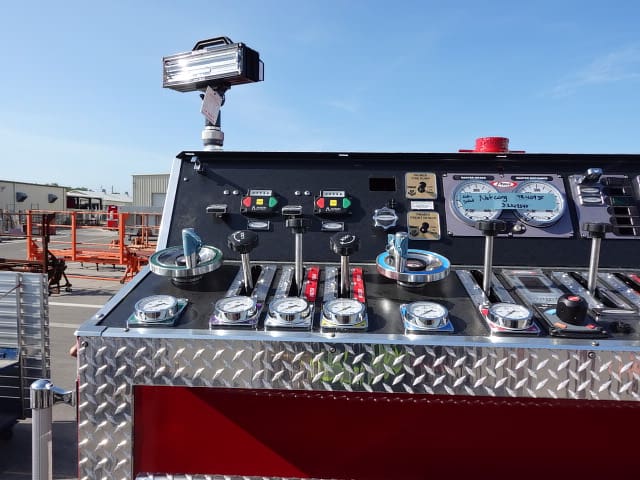

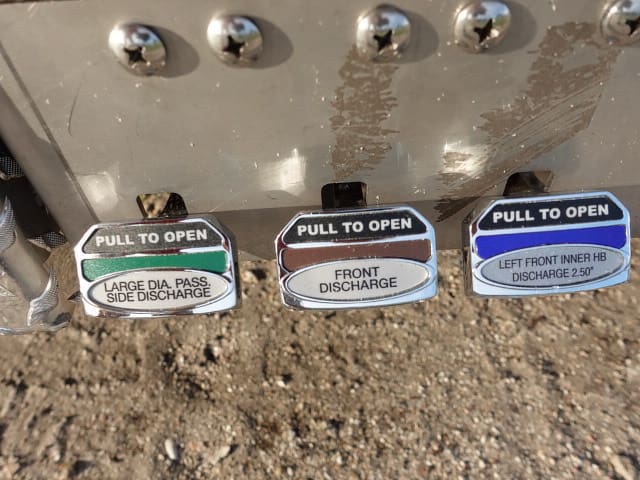

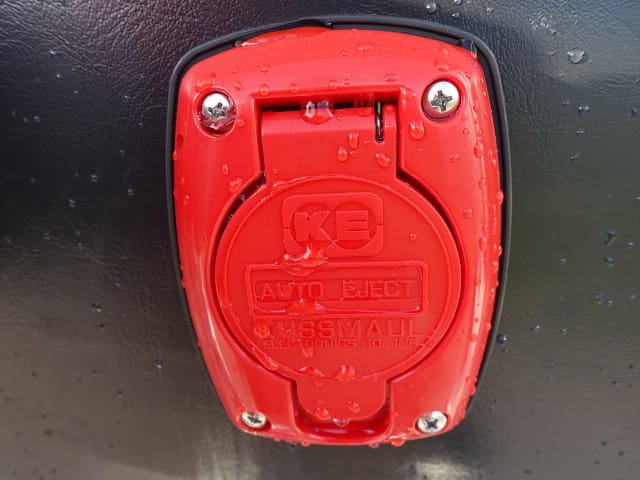

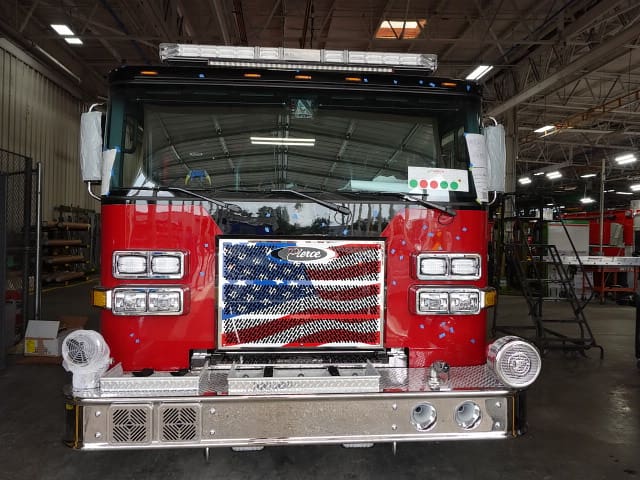

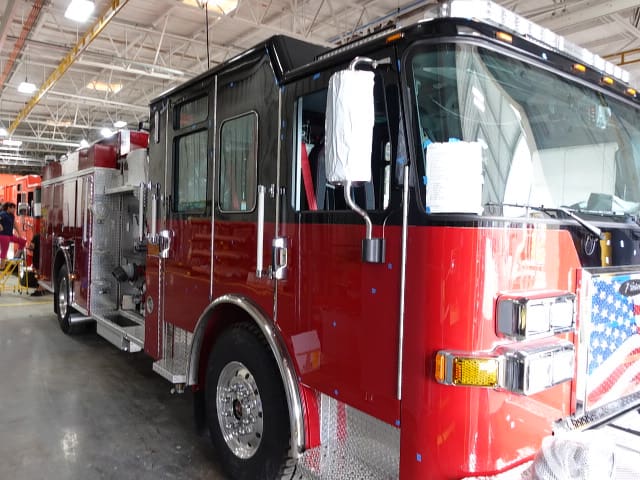

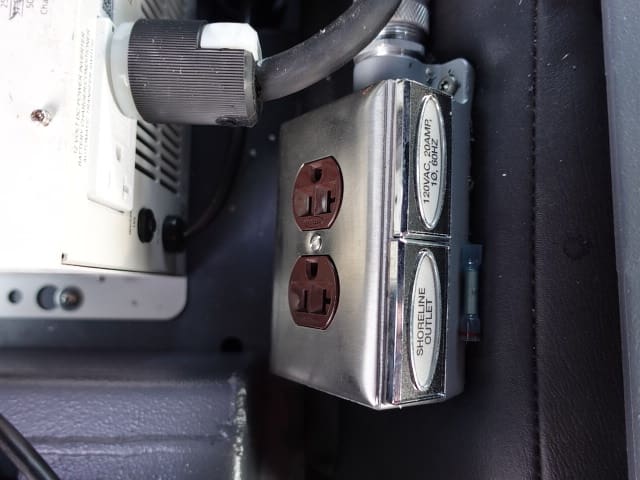

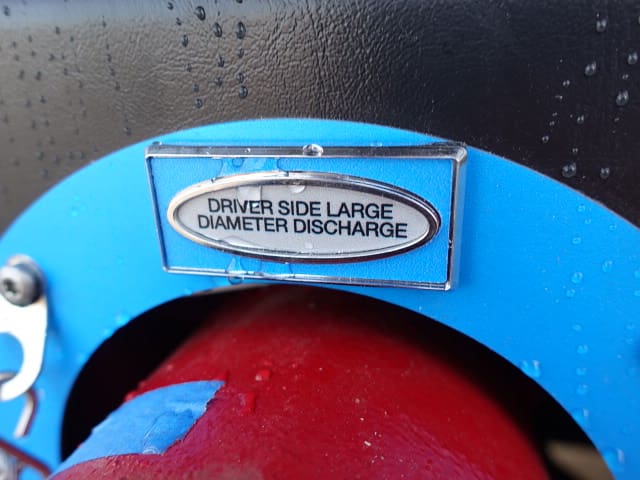

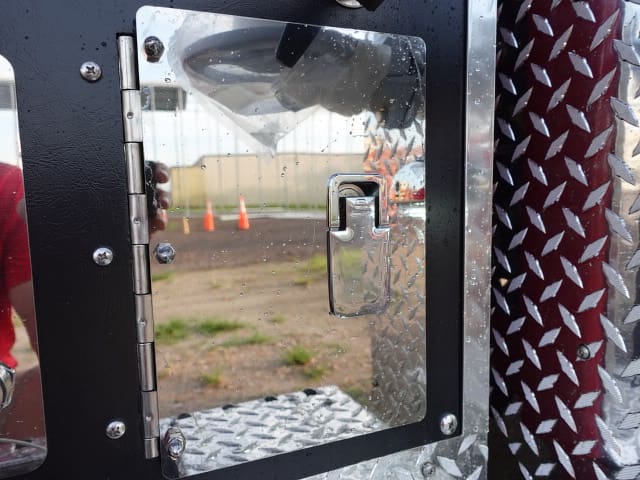

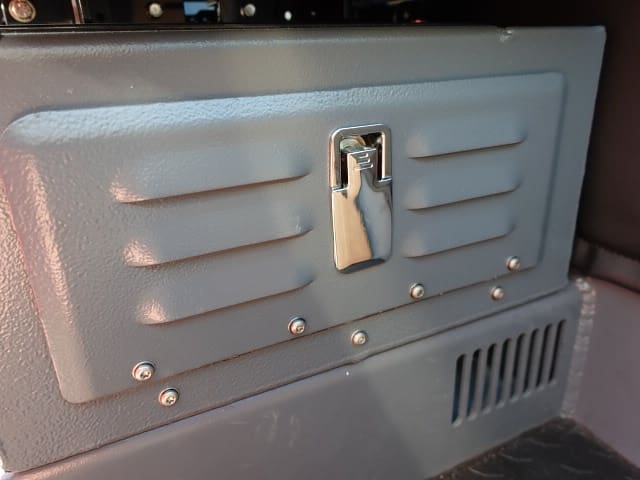

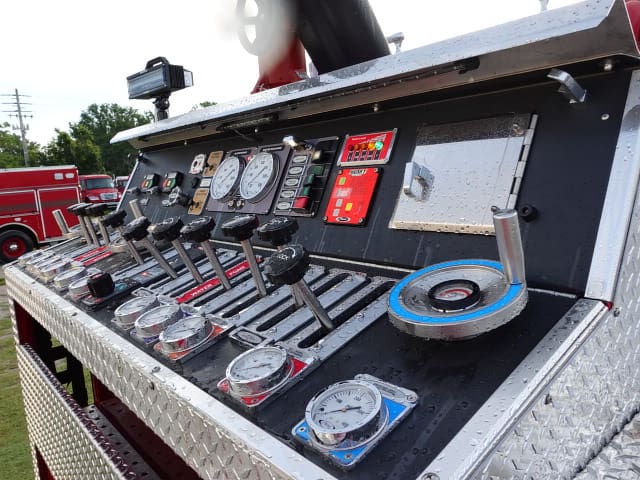

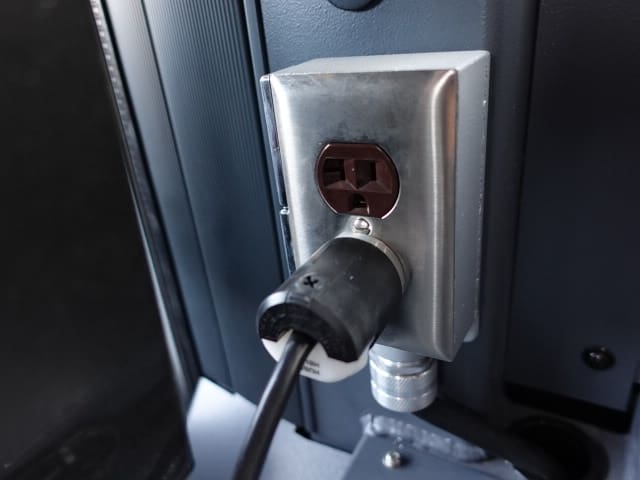

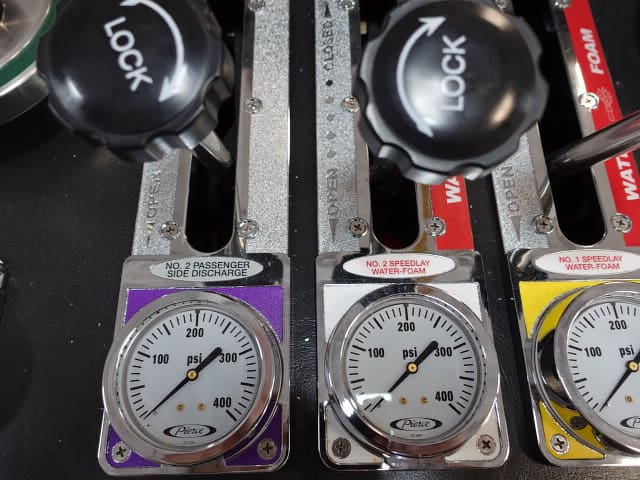

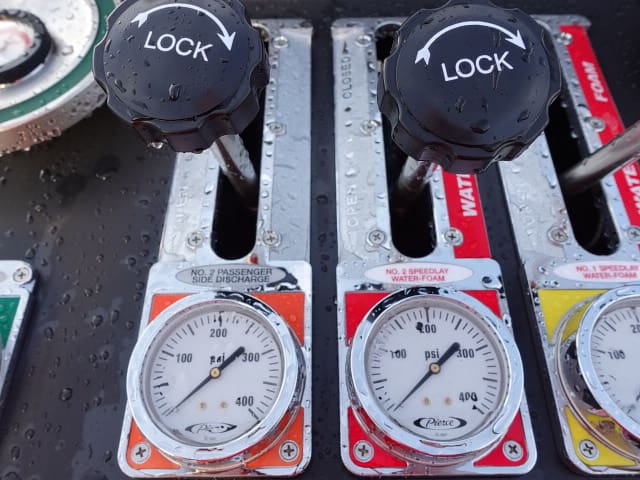

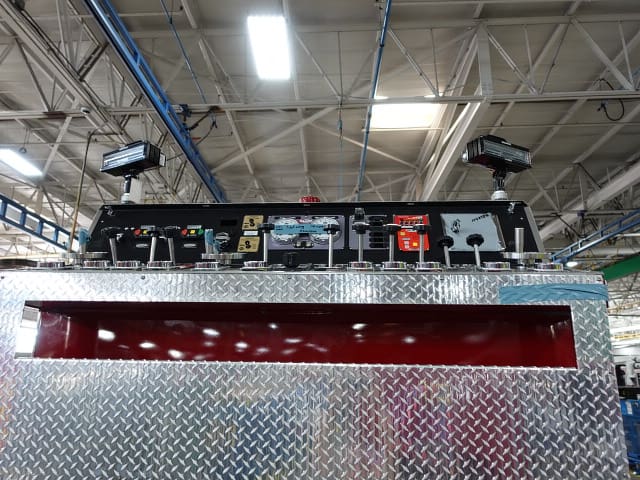

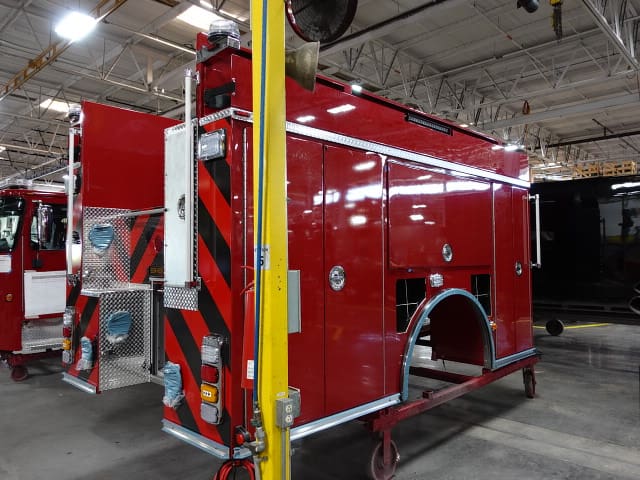

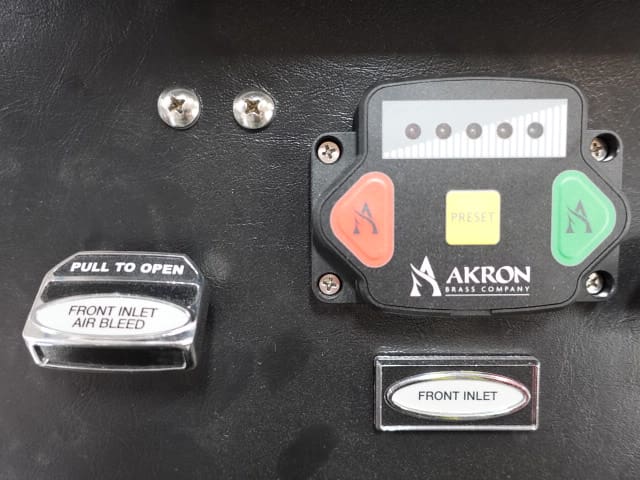

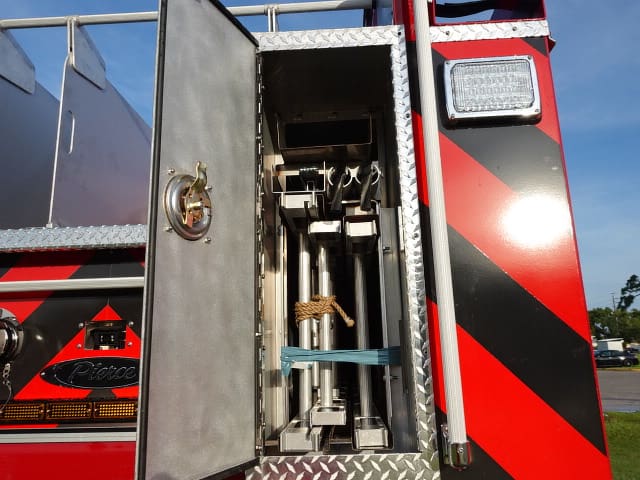

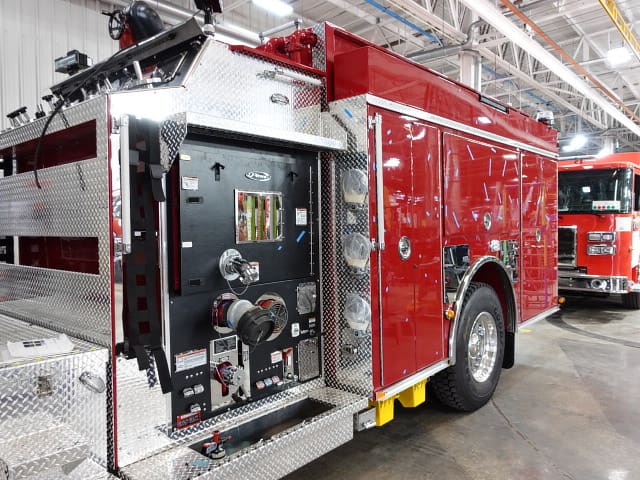

In this report, the apparatus completed final assembly and was staged for testing. Once testing completes it will release to final product evaluation where any remaining content will be applied. When finished, the apparatus will be made ready for the customer acceptance inspection. This is the last scheduled report.

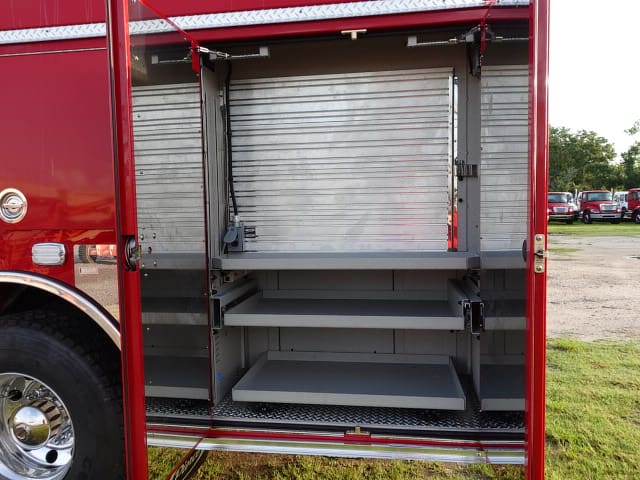

07-11-25

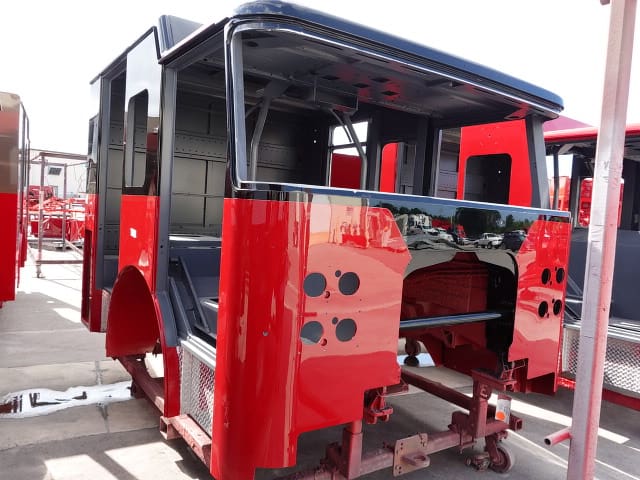

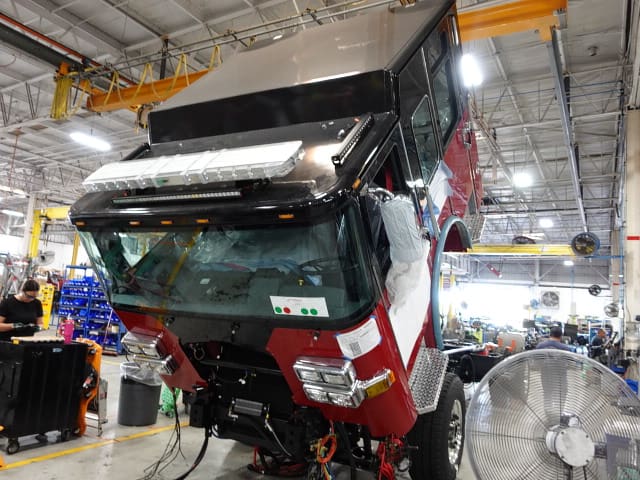

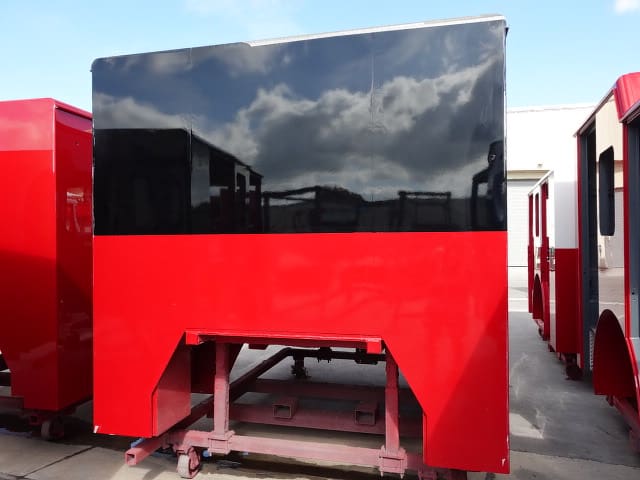

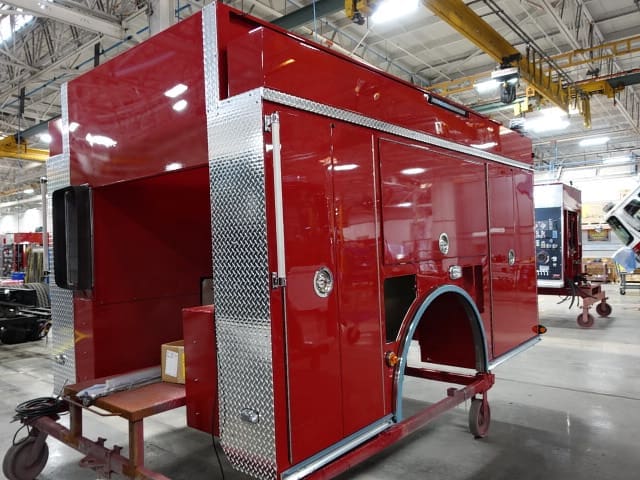

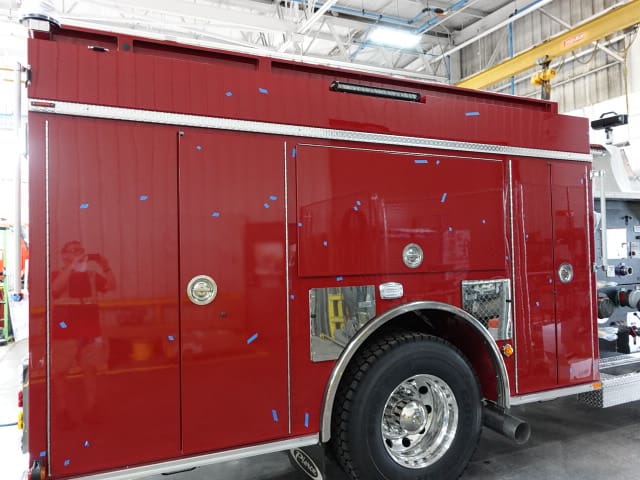

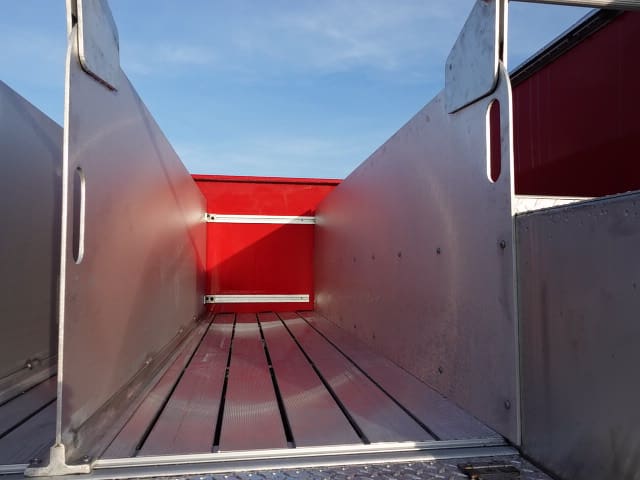

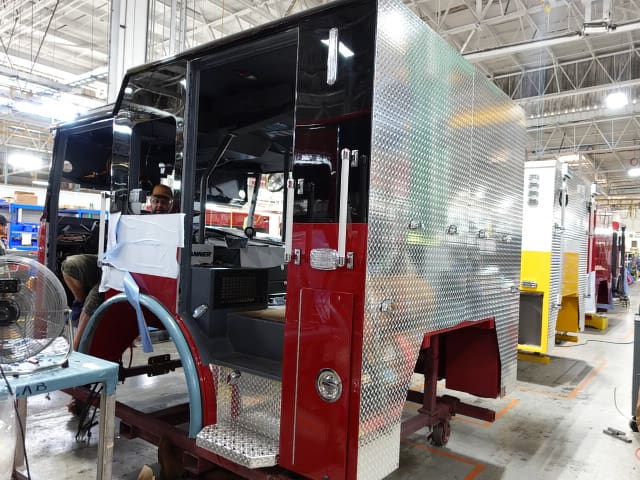

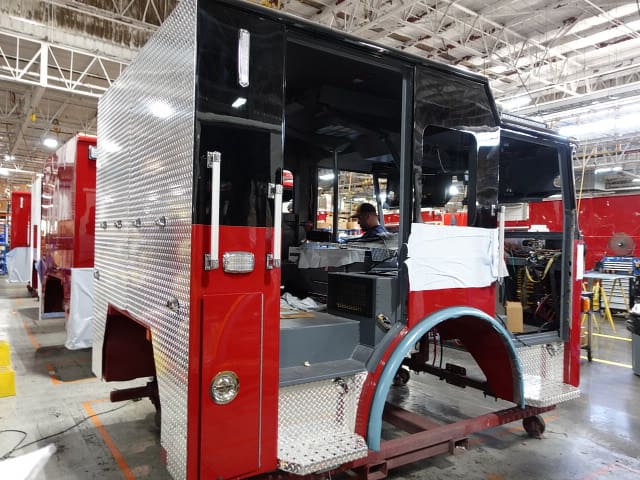

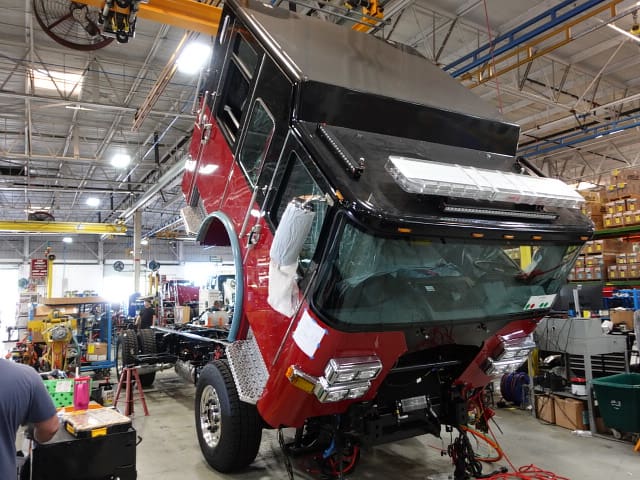

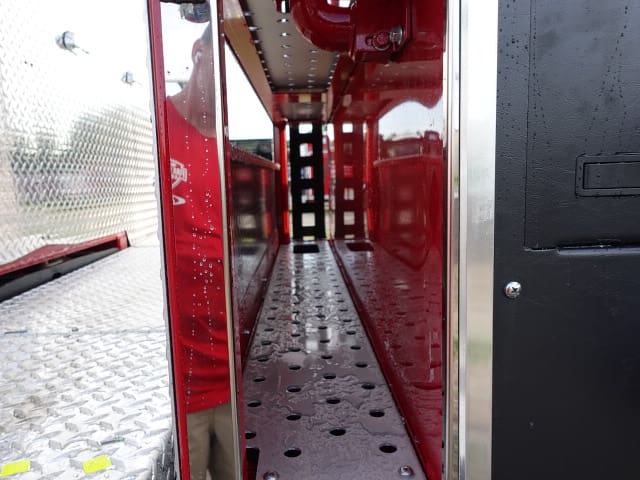

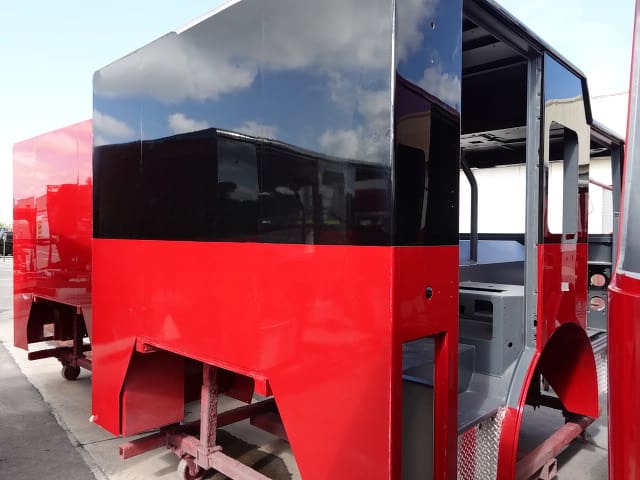

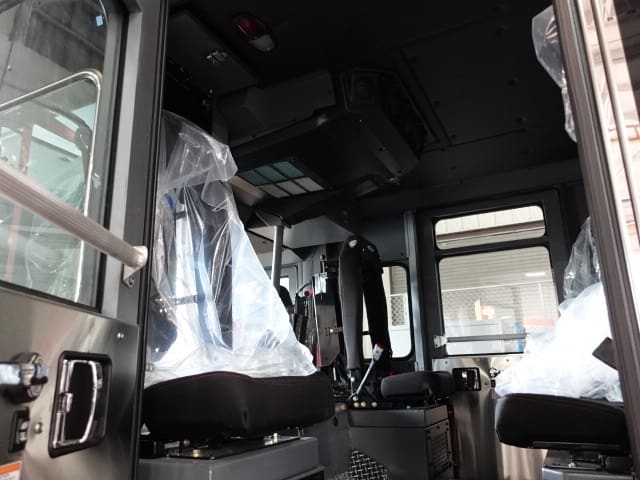

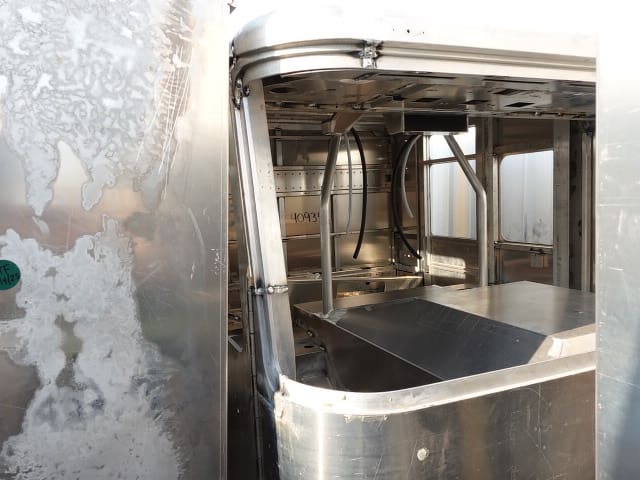

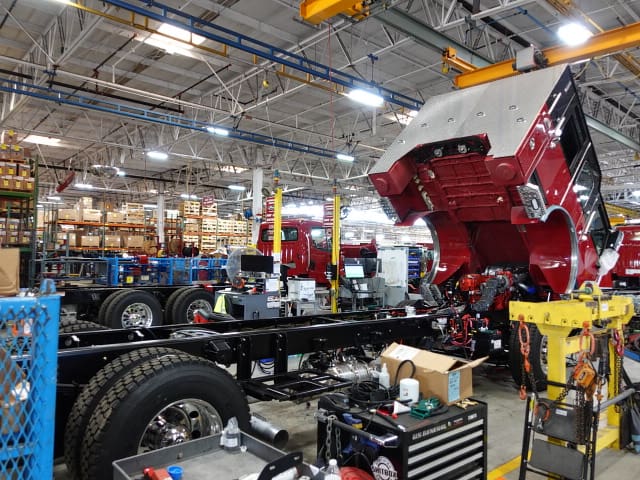

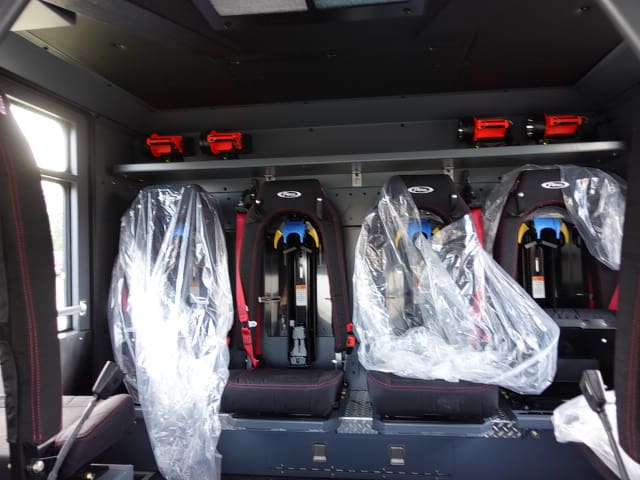

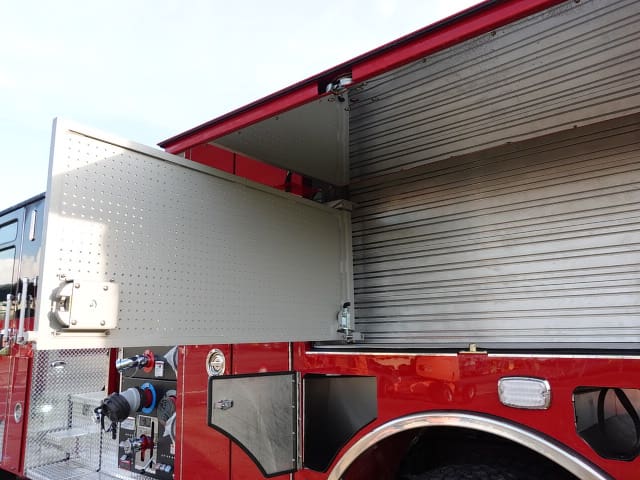

In this report, the body was installed on the chassis and the truck began final assembly.

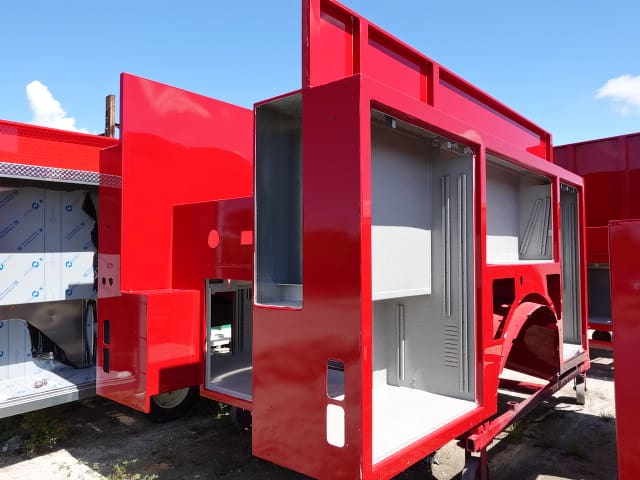

06-20-25

In this report, the chassis was staged to continue assembly, the pump house remained staged (no photos), and the body continued initial assembly.
06-13-25

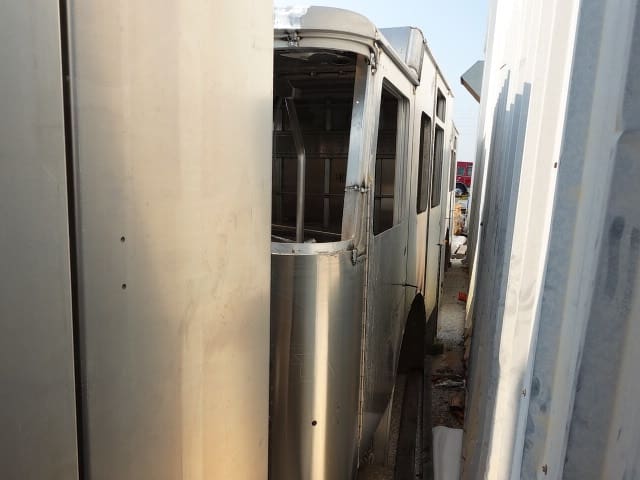

In this report, the chassis continued assembly, the pump house was staged (no photos), and the body began initial assembly.

06-06-25

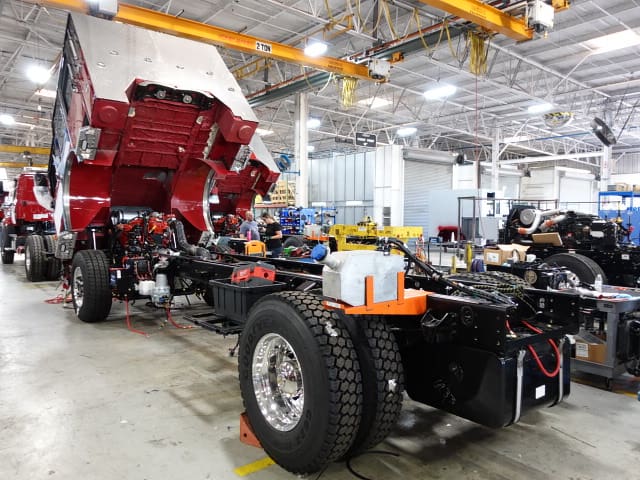

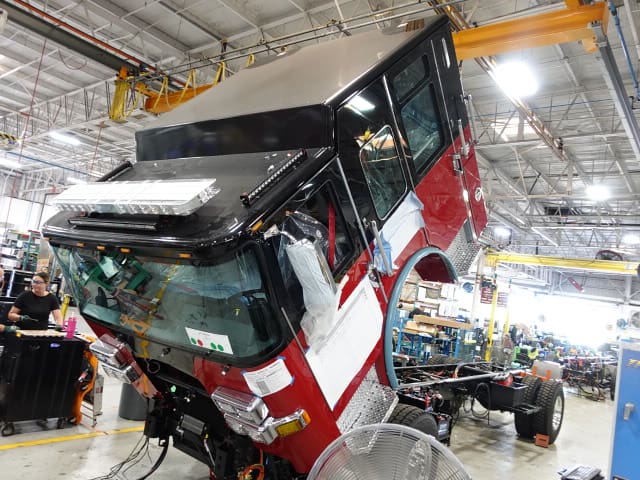

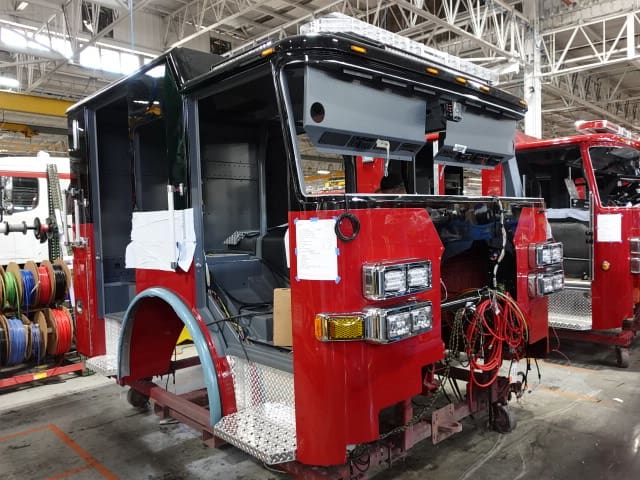

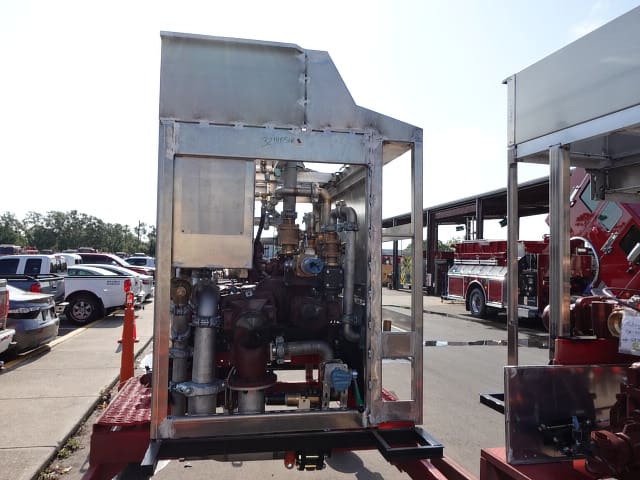

In this report, the cab completed initial assembly and was merged with the frame, the pump house was queued to be mounted on the chassis, and the body remained staged (no photos).
05-30-25

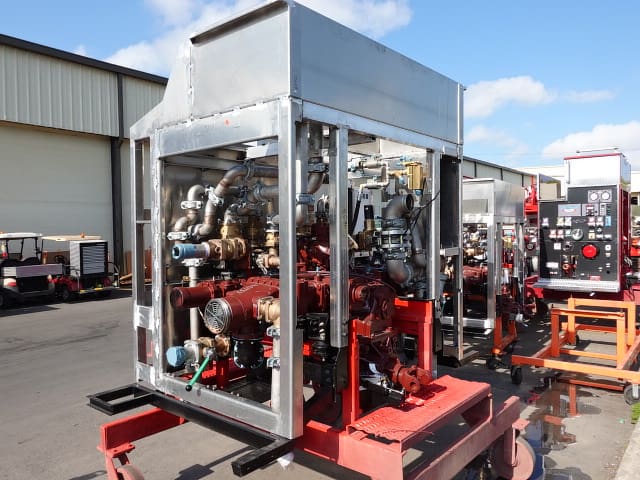

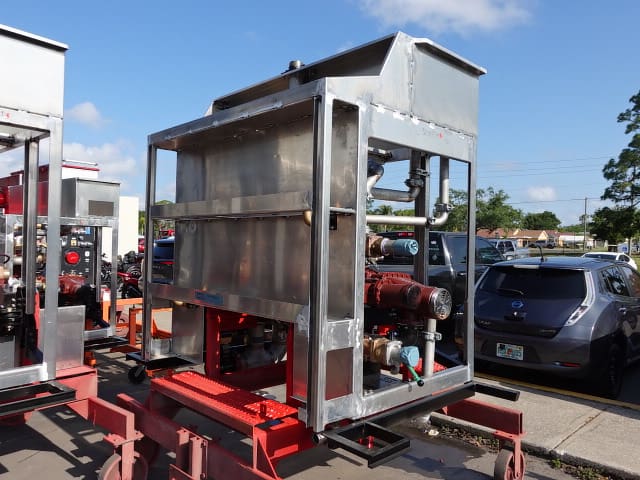

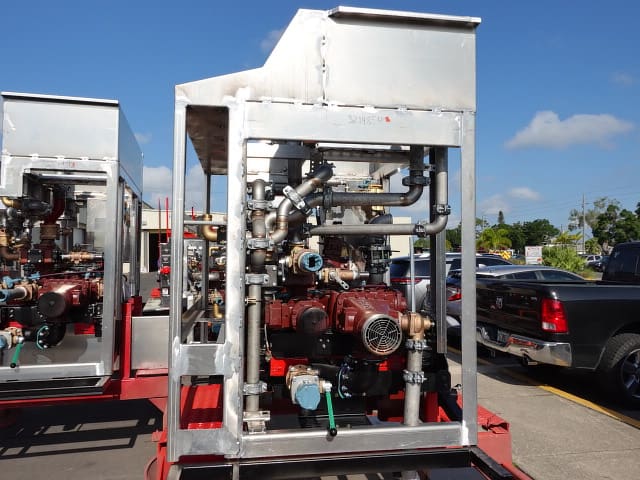

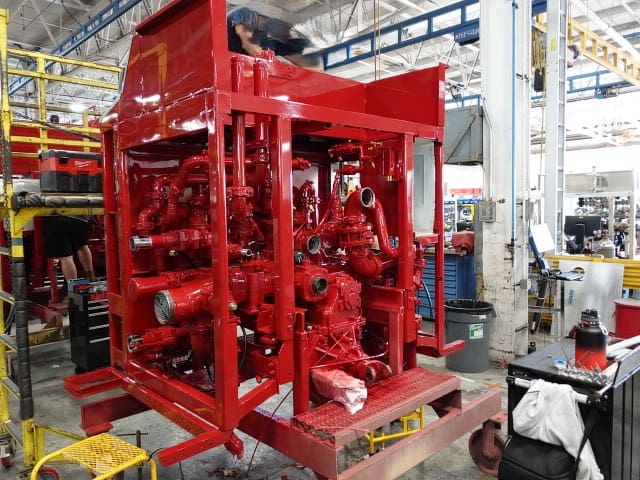

In this report, the cab began initial assembly, the frame build continued, the pump house completedinitial assembly, and the body remainedstaged (no photos).
05-23-25
In this report, the cab completed the paint process, the frame remained staged (no photos), the pump house continued initial assembly, and the body was staged (no photos).
05-16-25

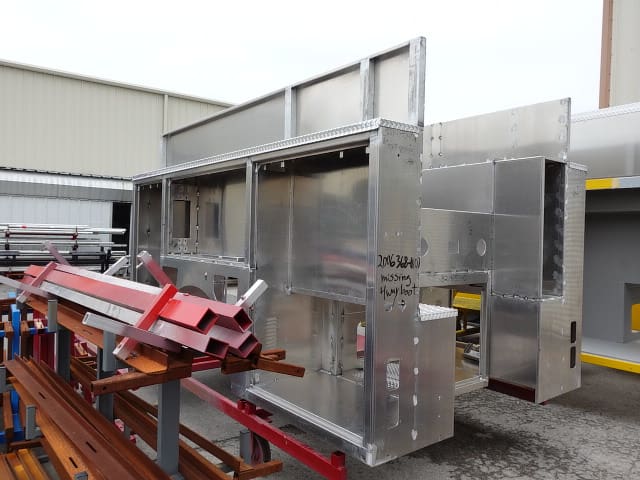

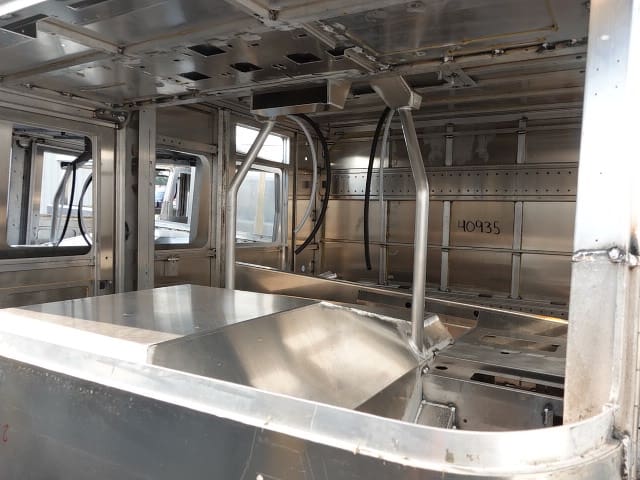

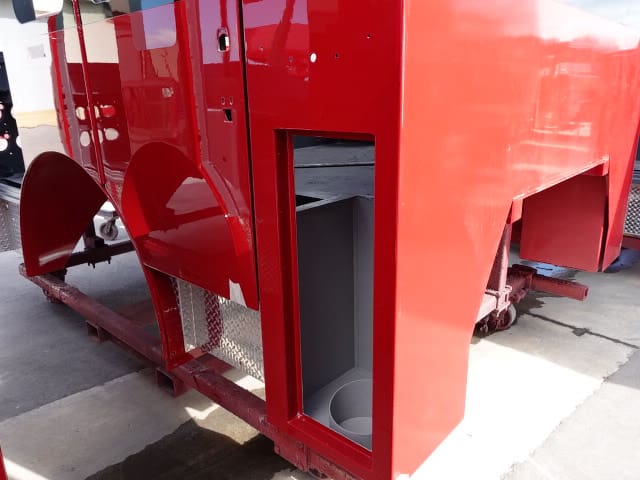

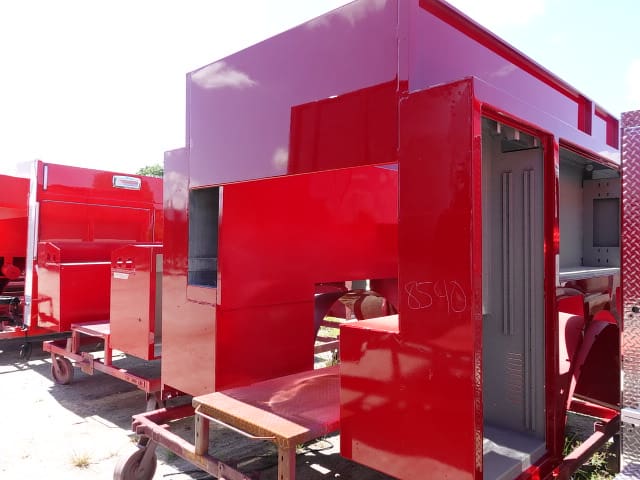

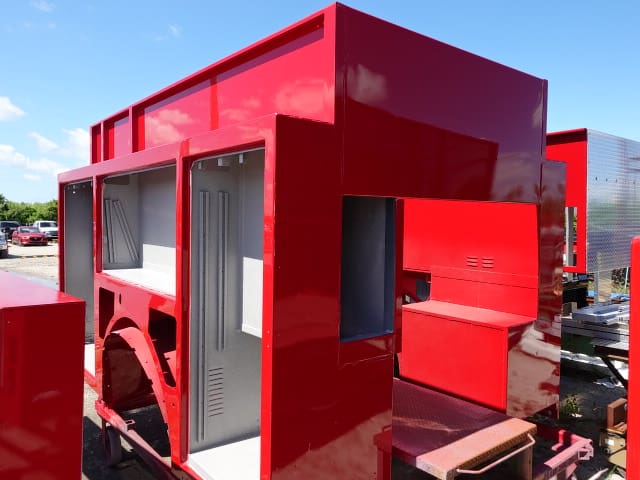

In this report, the cab continued through paint, the frame remained staged (no photos), the pump house began initial assembly, and the body completed fabrication and paint.
05-02-25

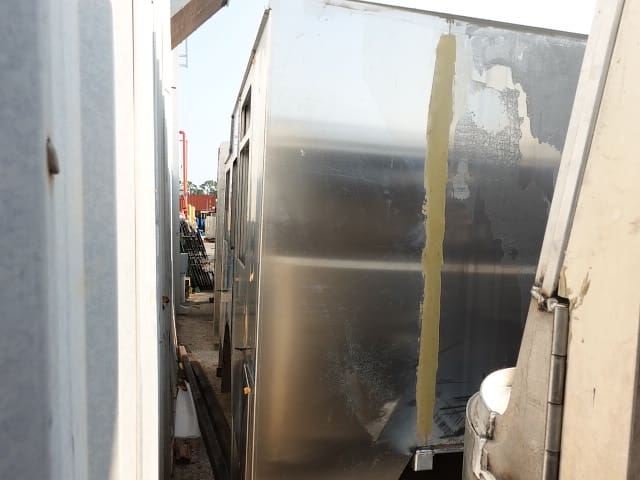

In this report, the cab began the paint process, the frame was staged (no photos), the pump house remained staged, and the body continued the fabrication process.
04-25-25

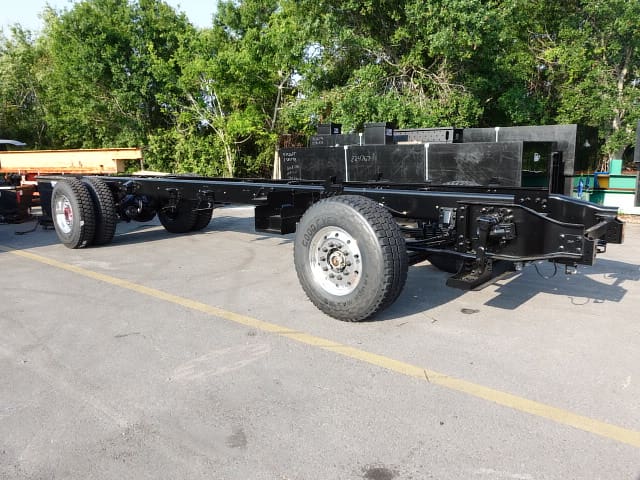

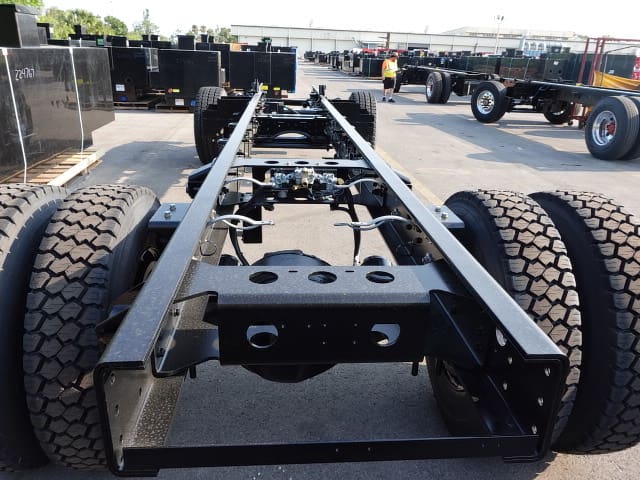

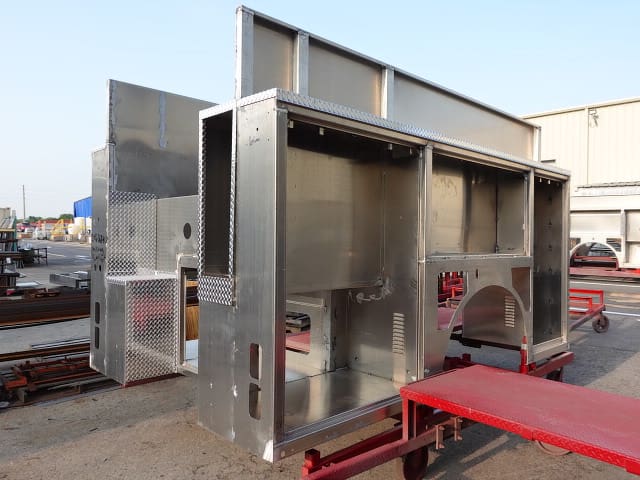

In this report, the cab was staged (no photos), the frame build continued, the pump house continued initial assembly, and the body continued fabrication.

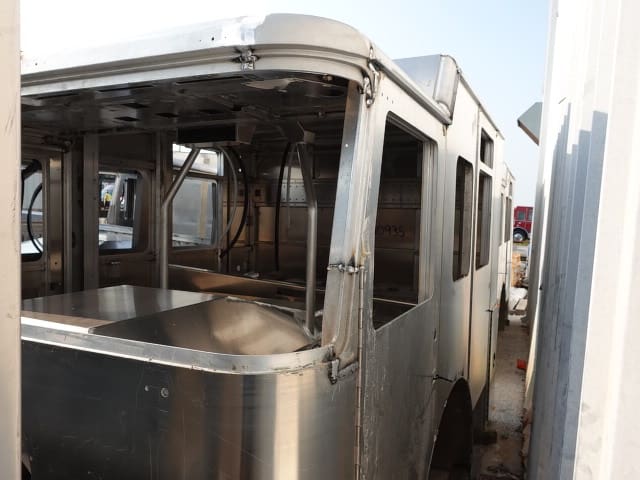

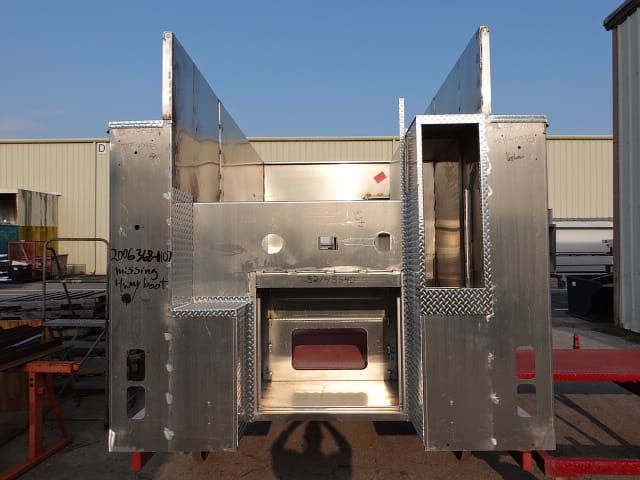

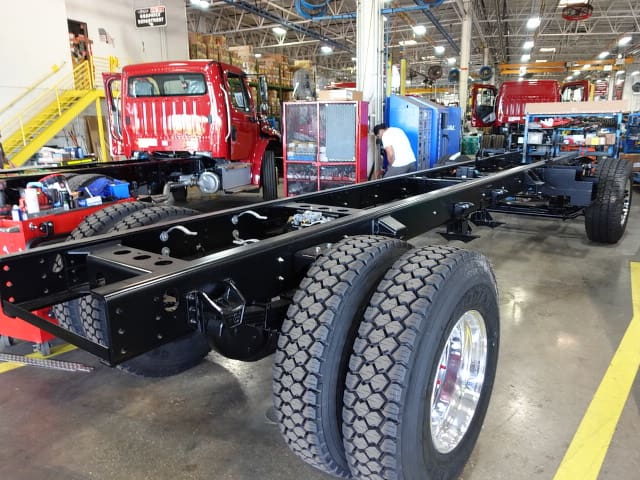

04-18-25

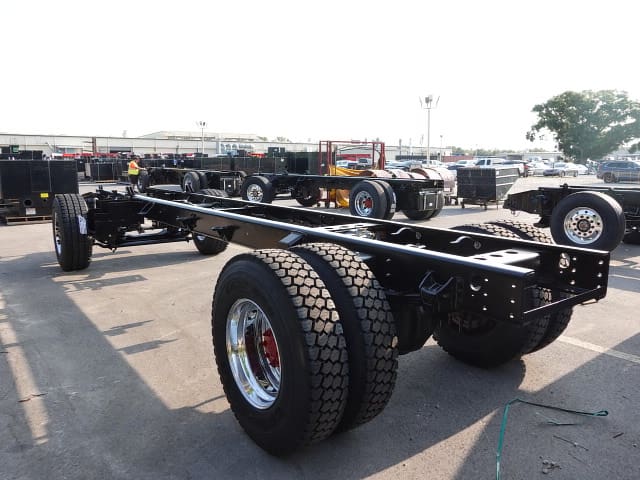

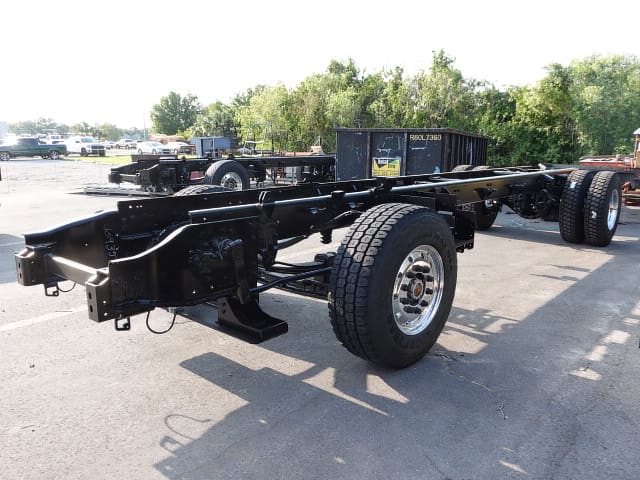

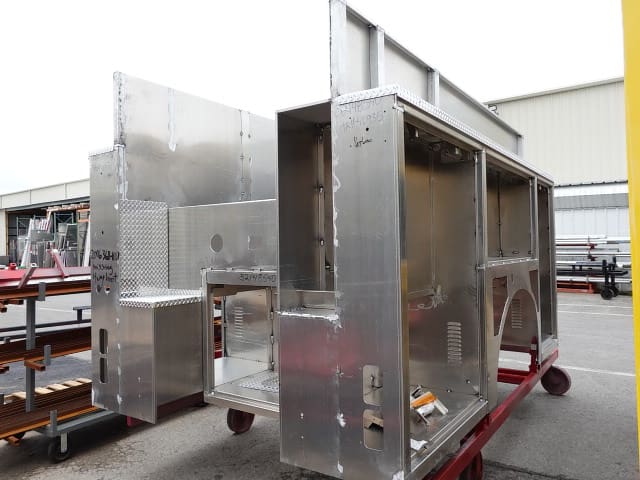

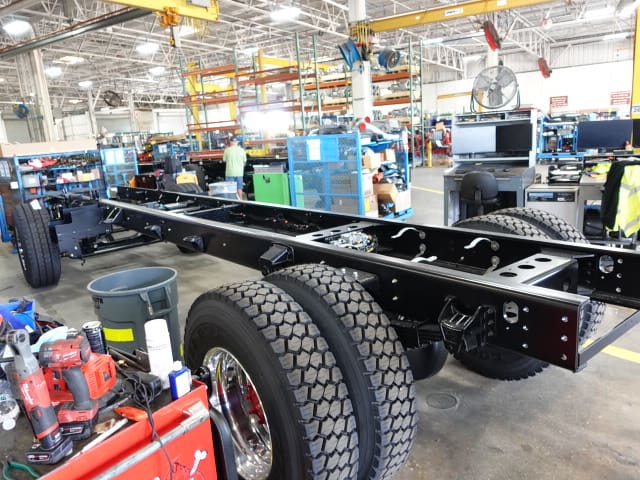

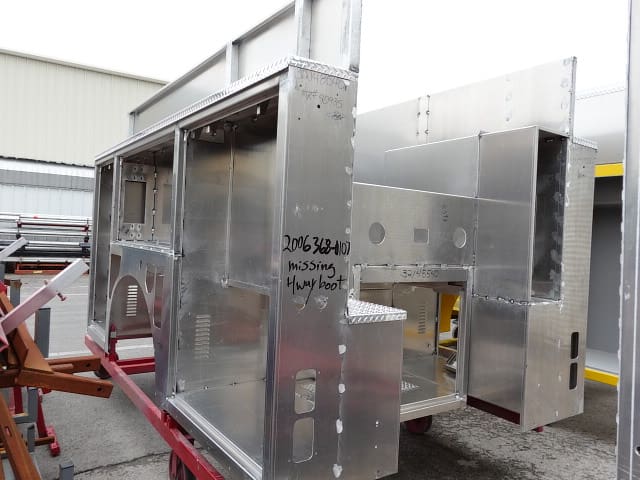

In this report, the cab was fabricated, the frame build began, the pump house began initial assembly, and the body continued the fabrication process.

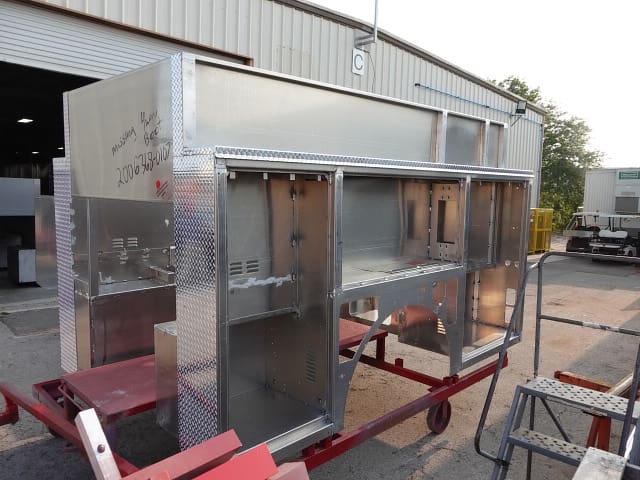

04-11-25

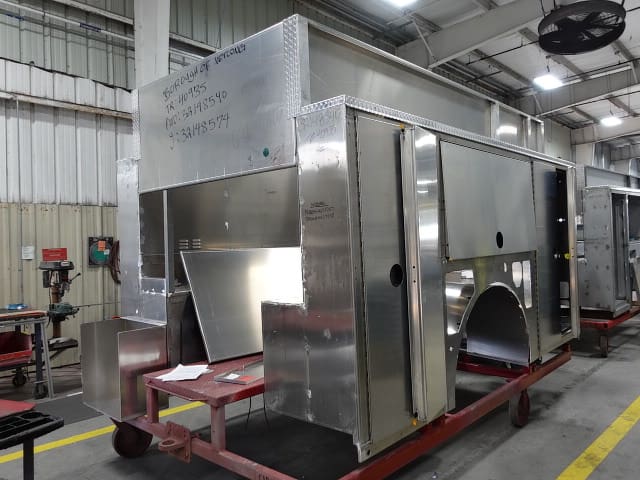

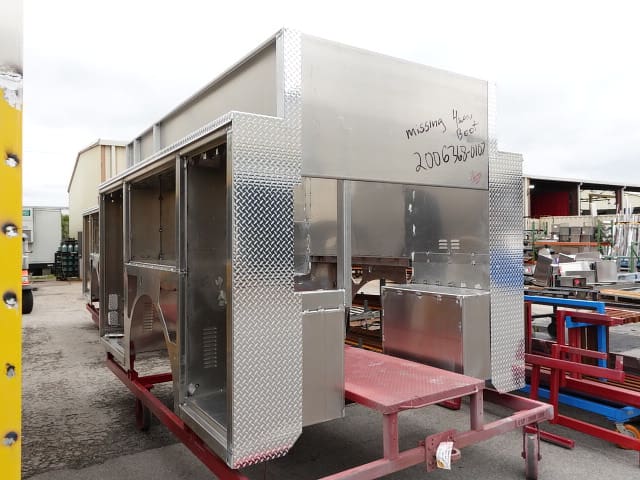

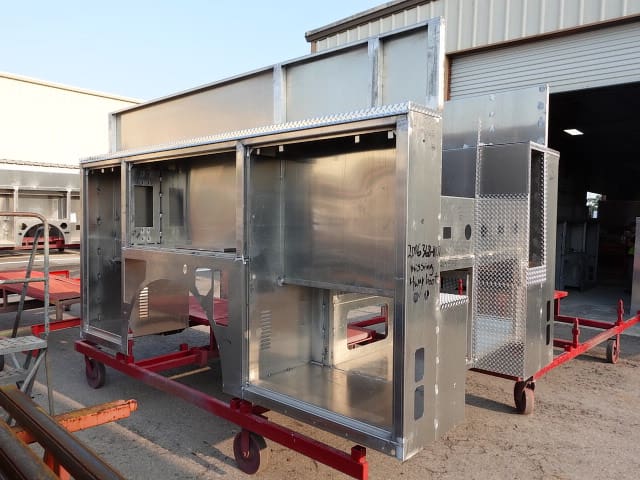

This new Pierce apparatus is now in production! In this report, the body began fabrication.
