07-18-25

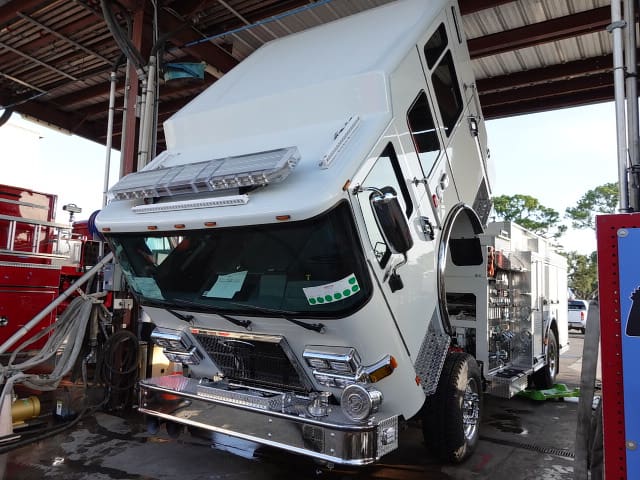

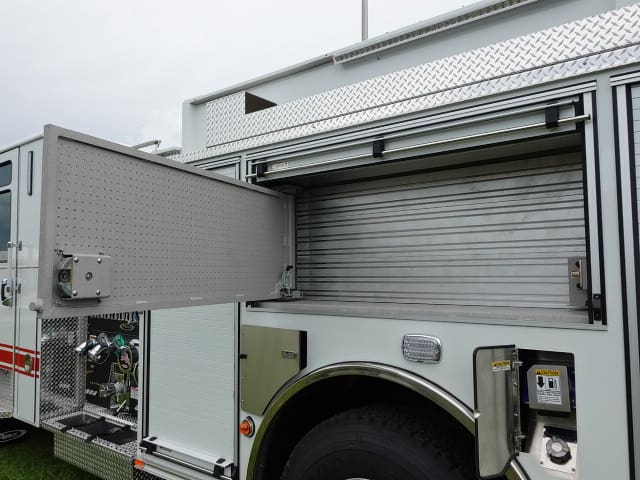

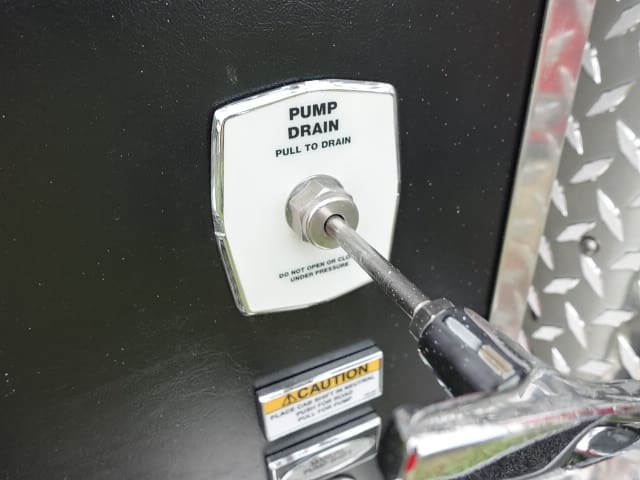

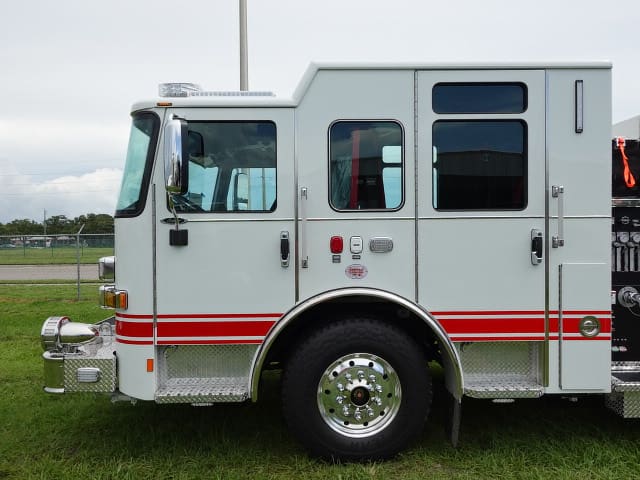

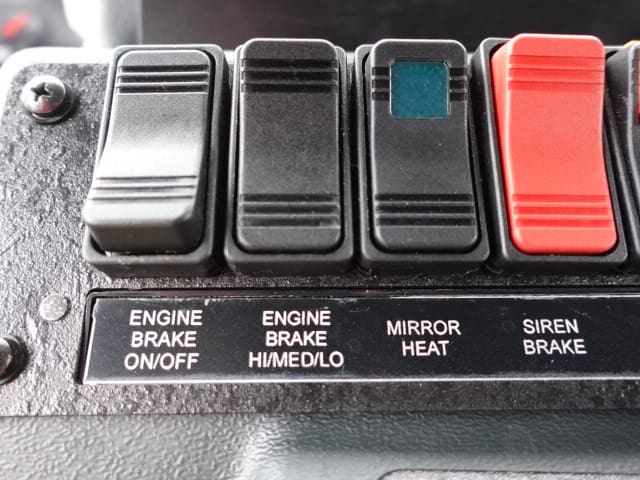

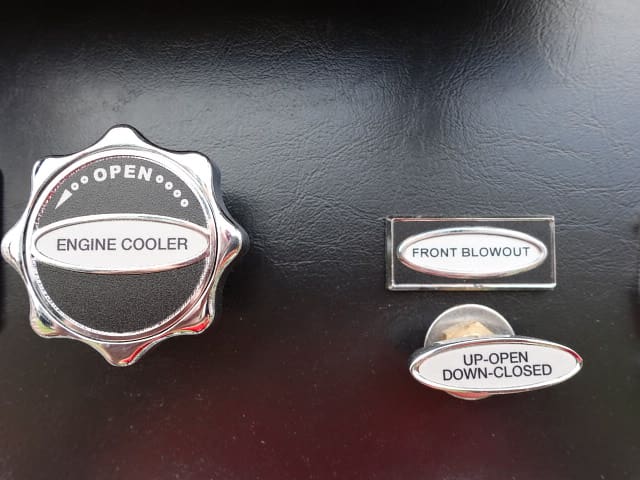

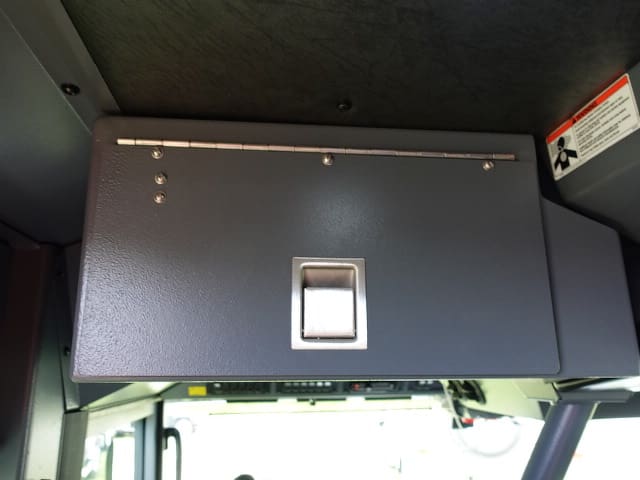

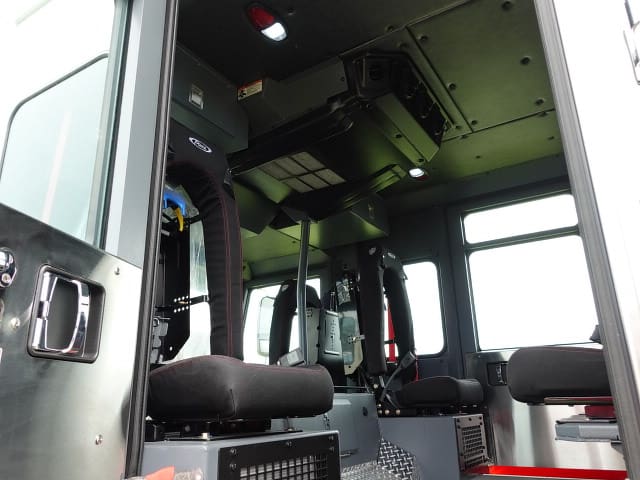

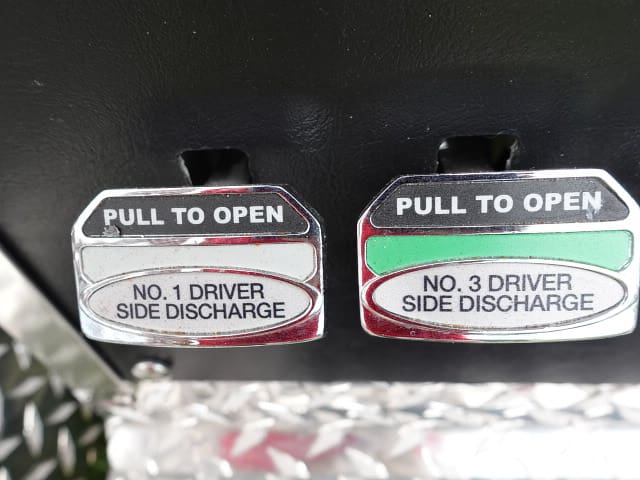

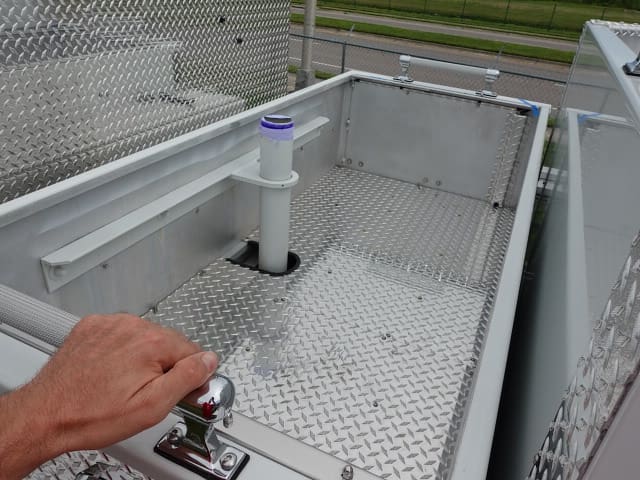

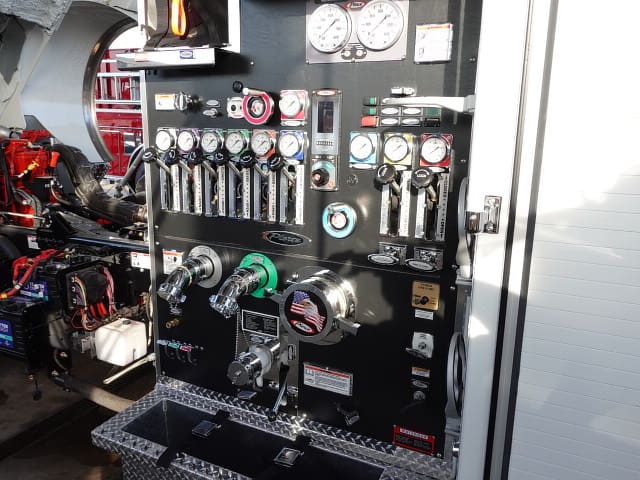

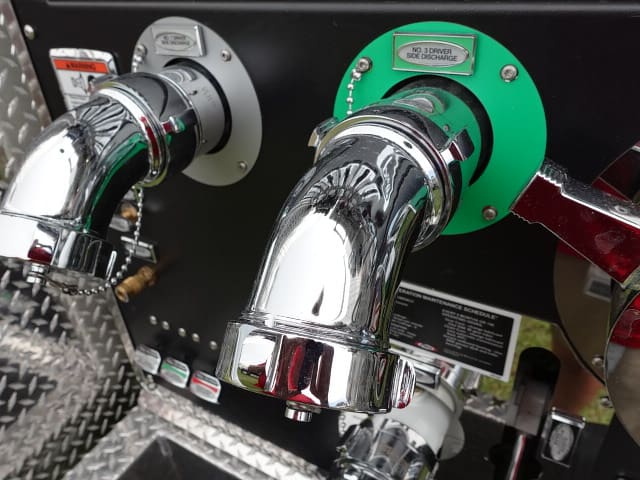

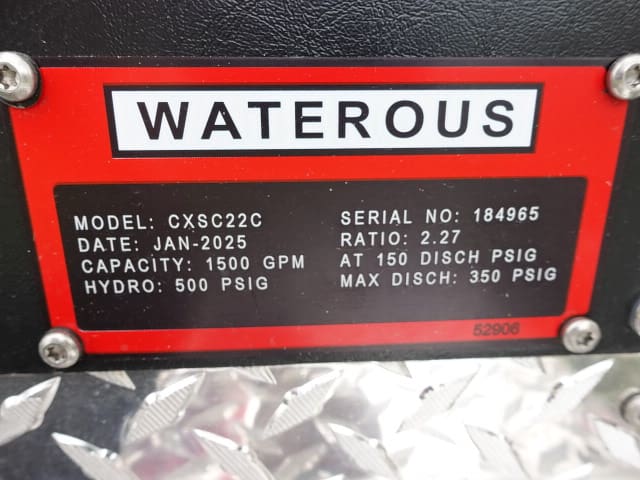

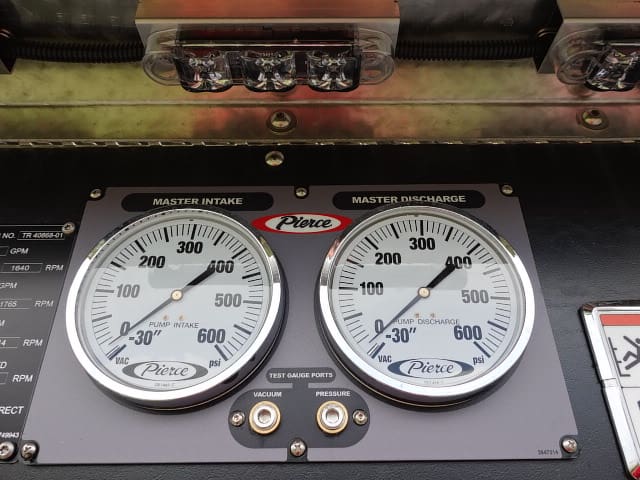

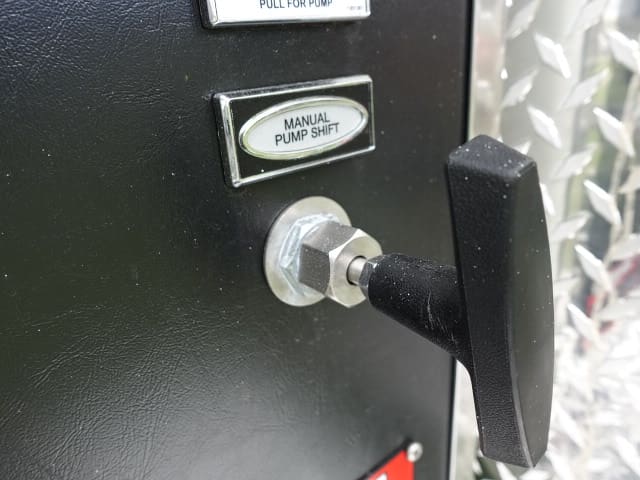

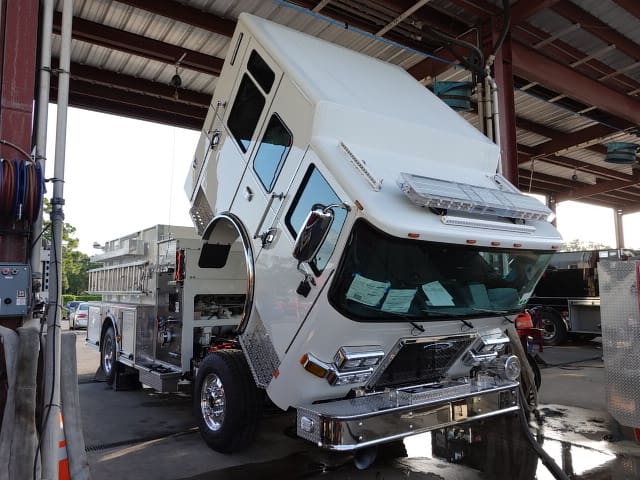

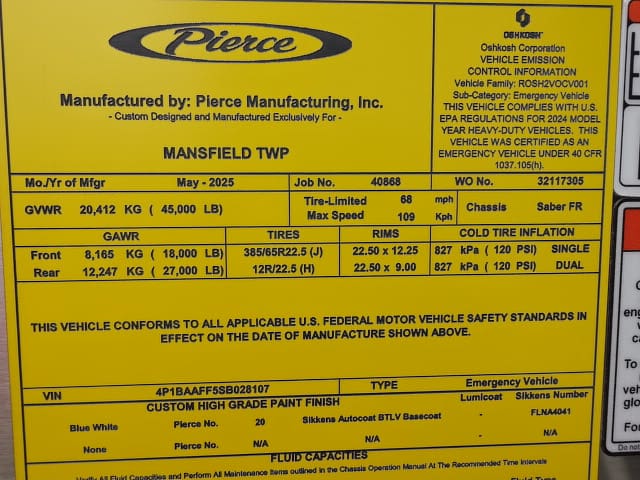

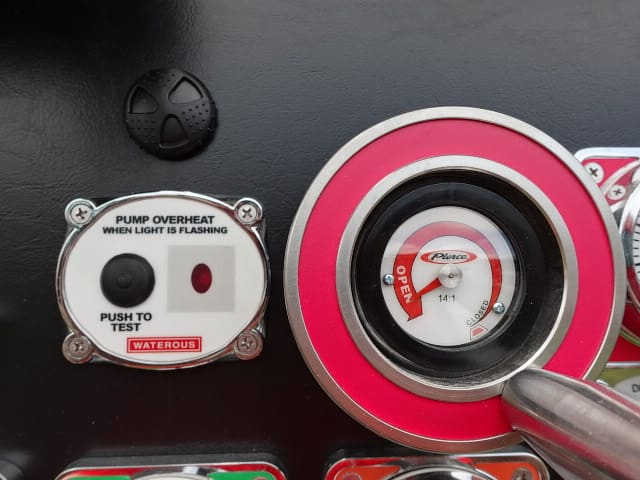

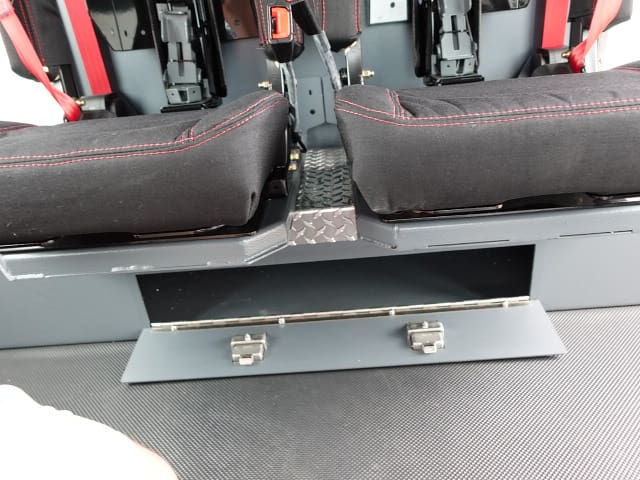

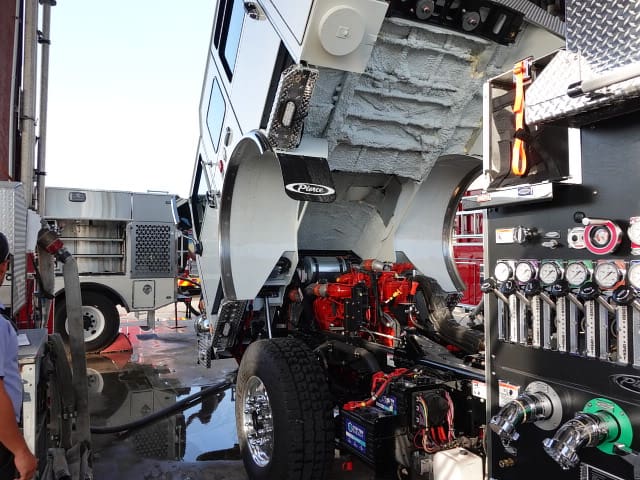

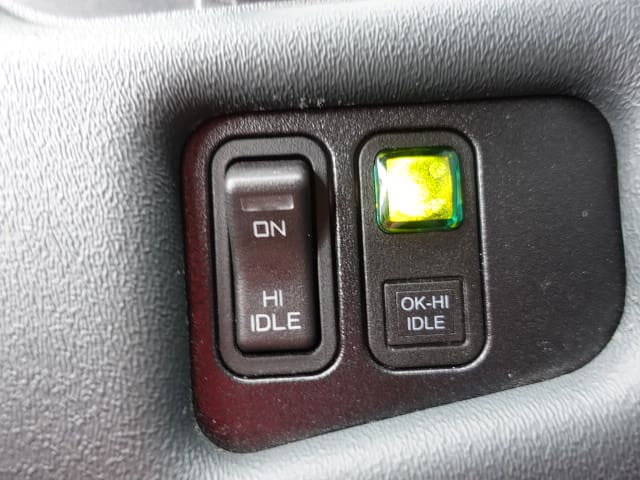

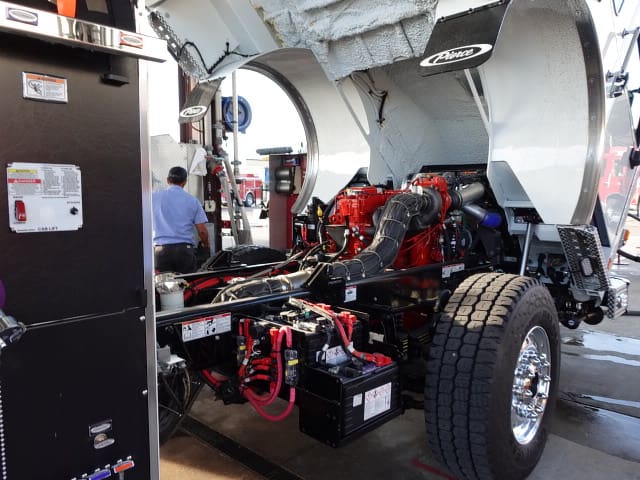

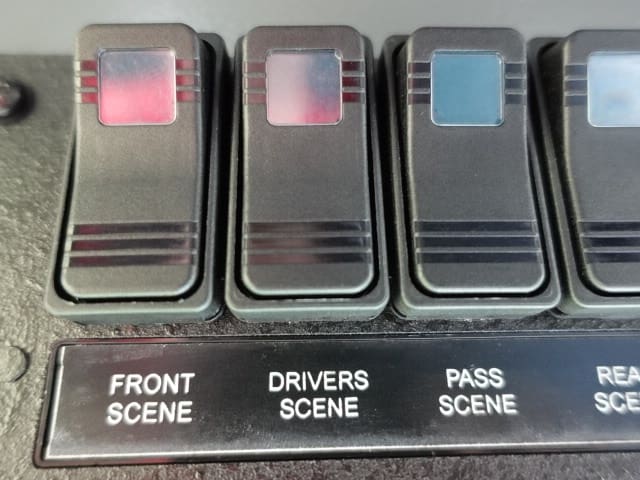

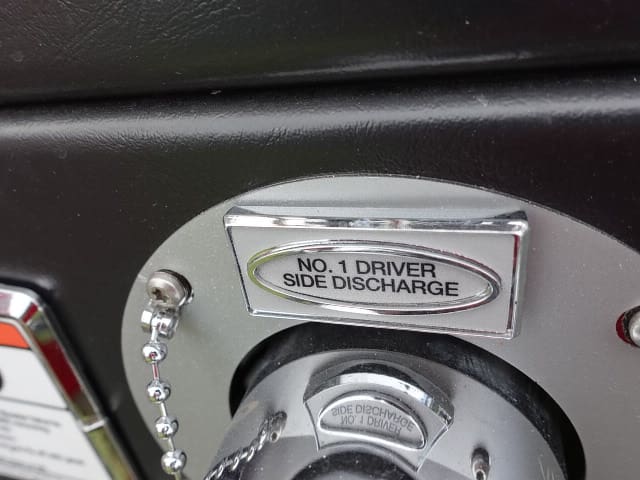

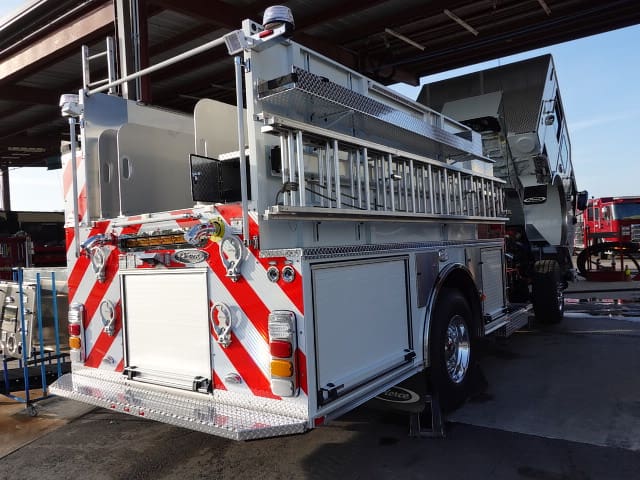

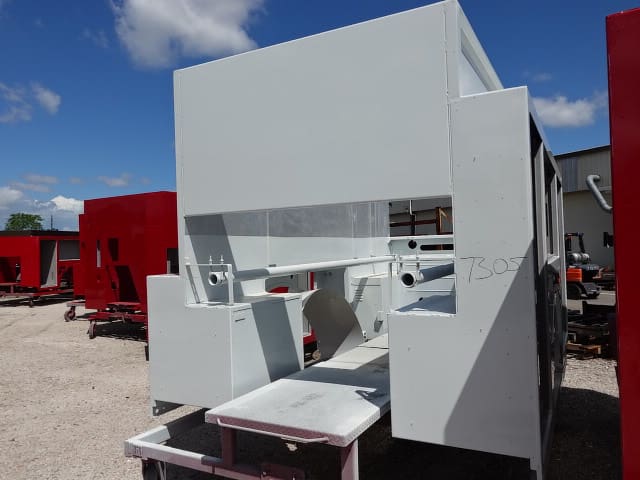

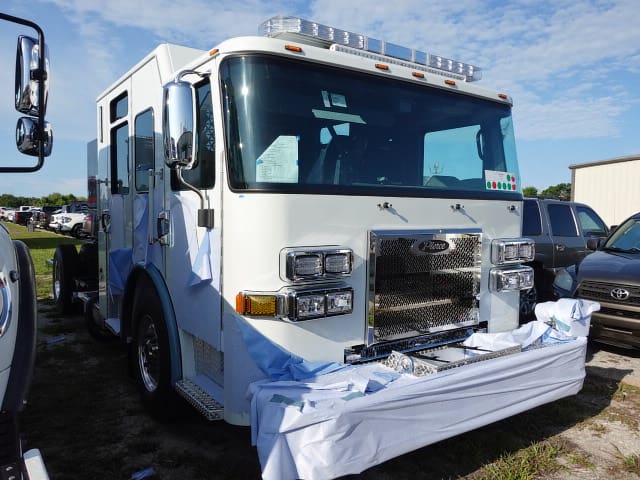

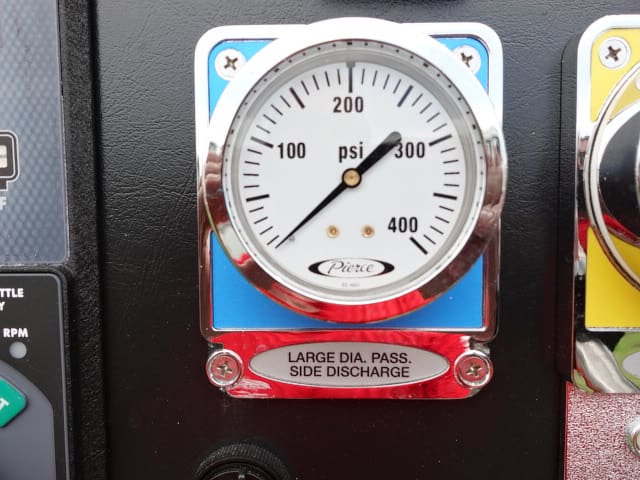

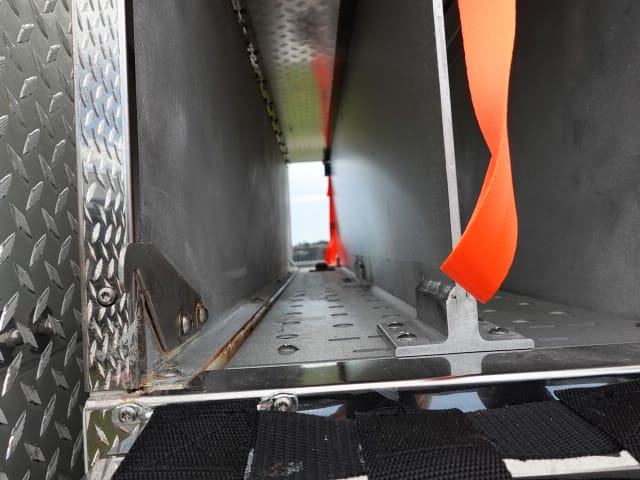

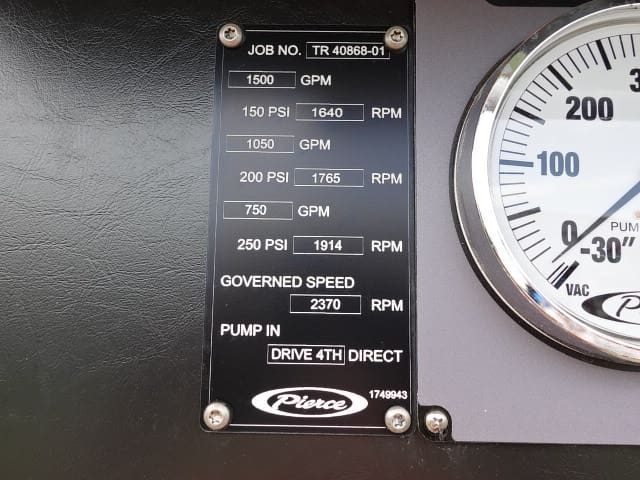

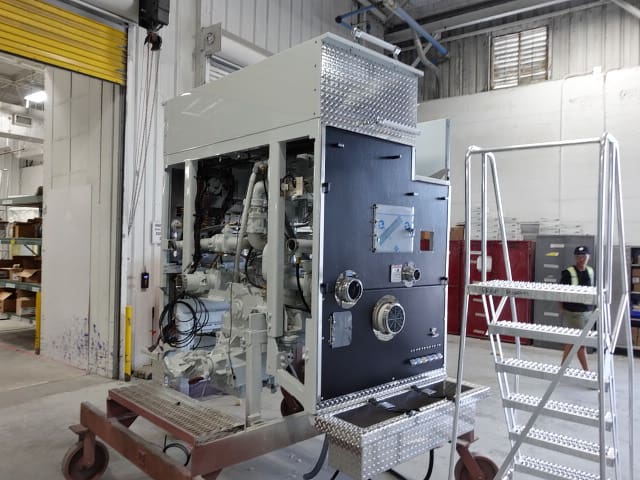

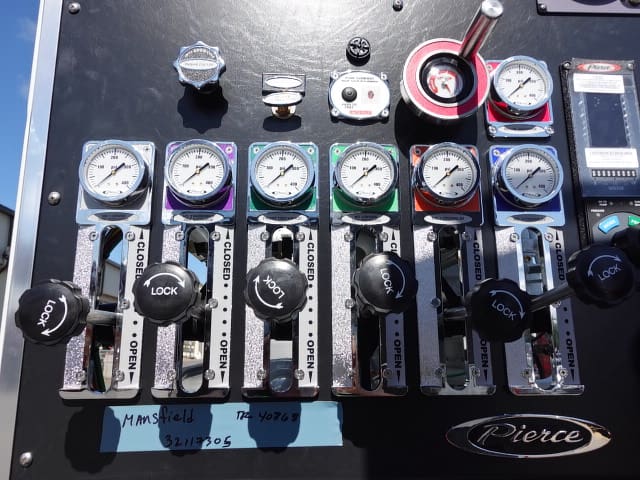

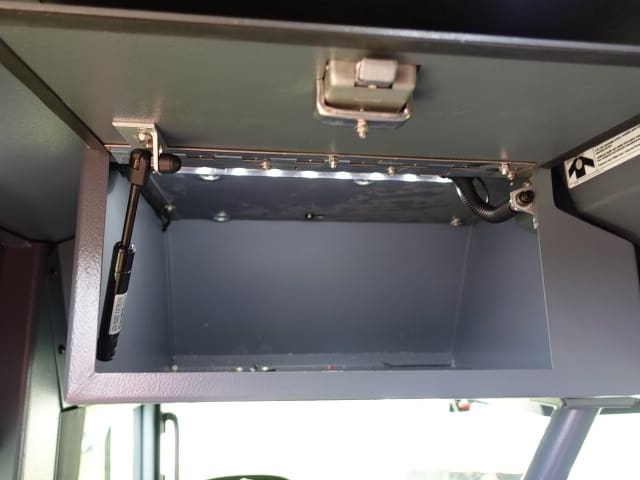

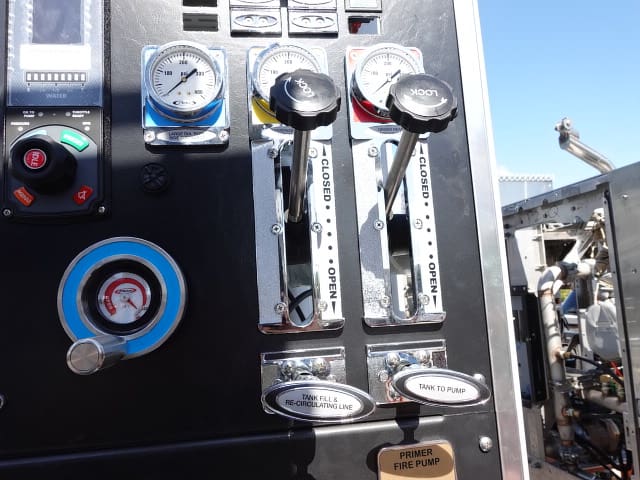

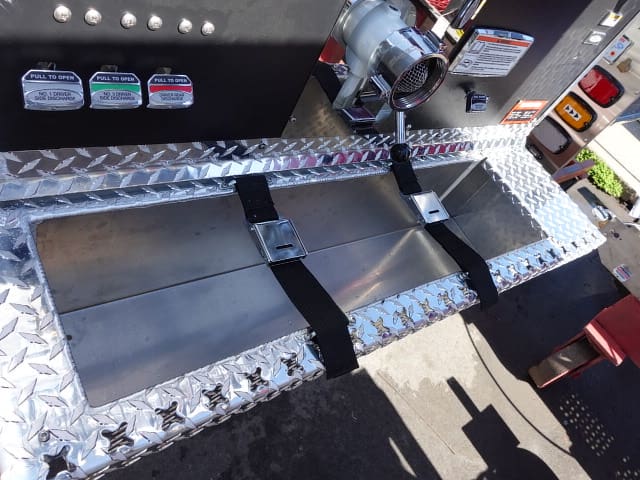

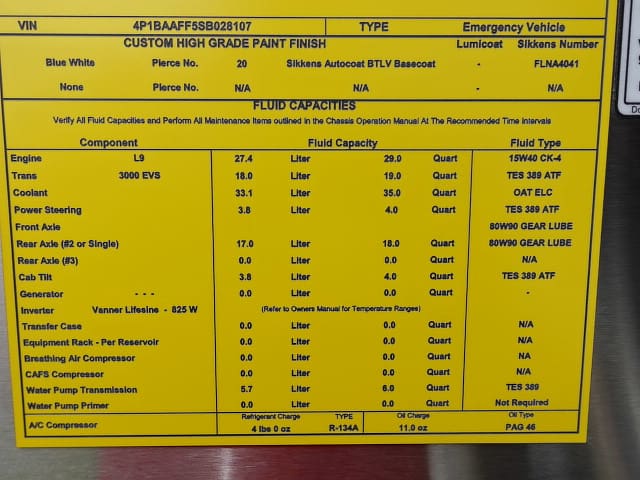

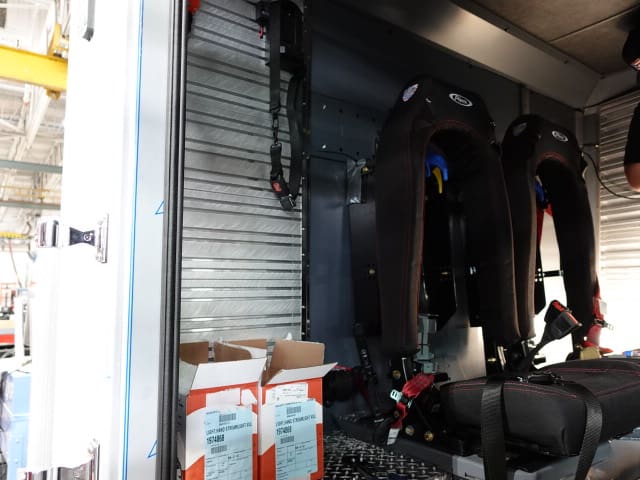

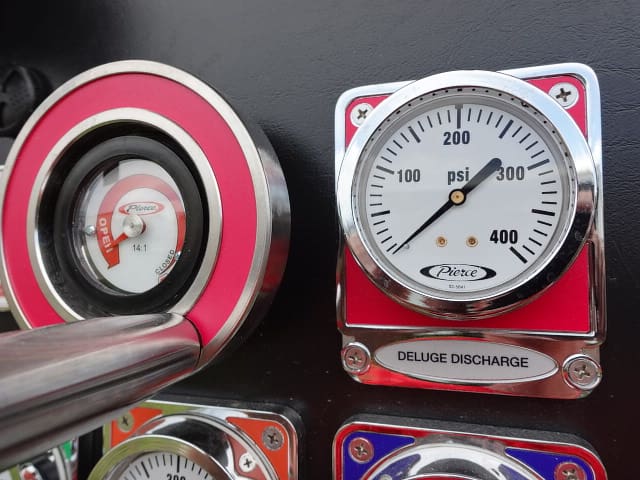

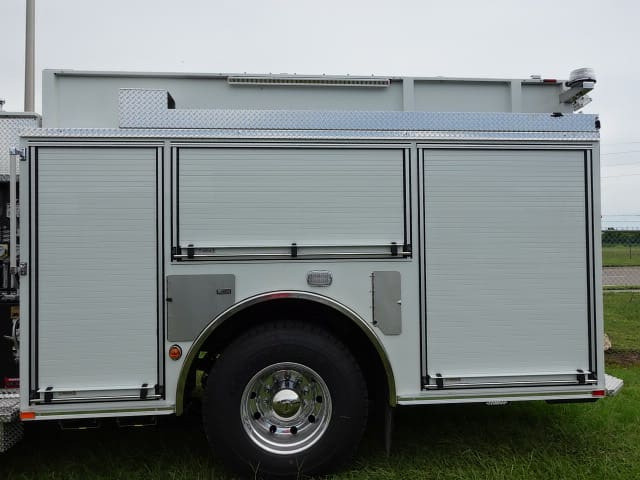

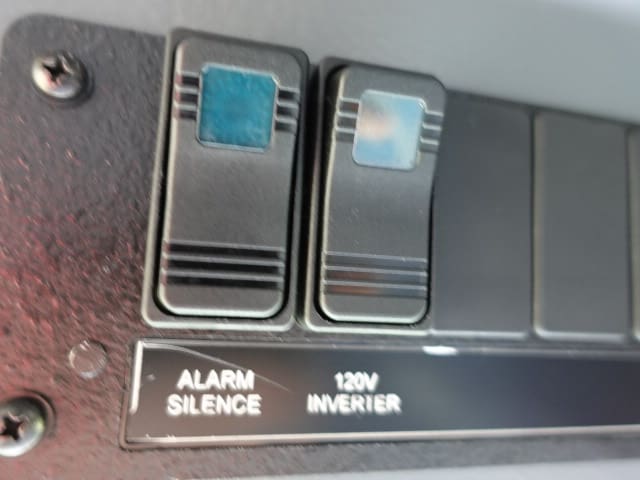

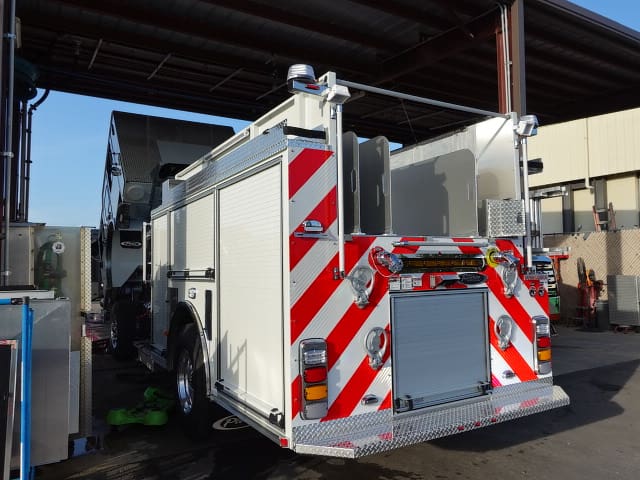

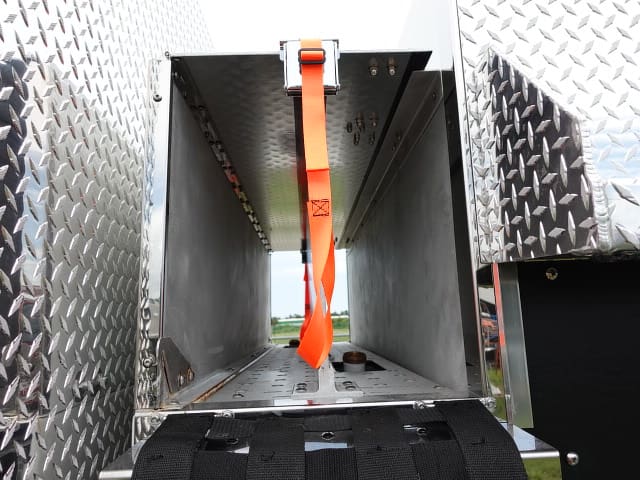

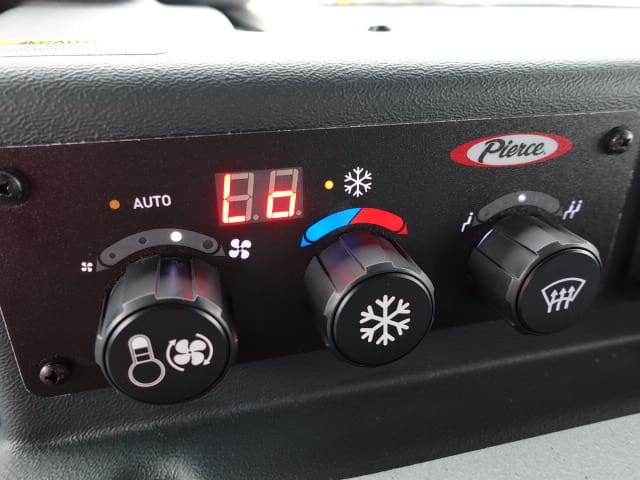

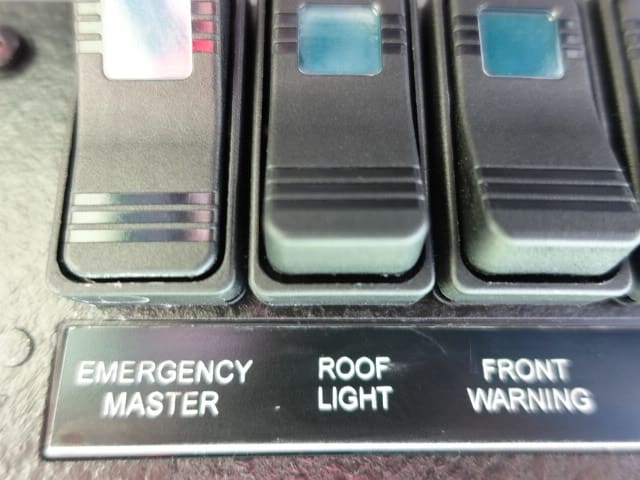

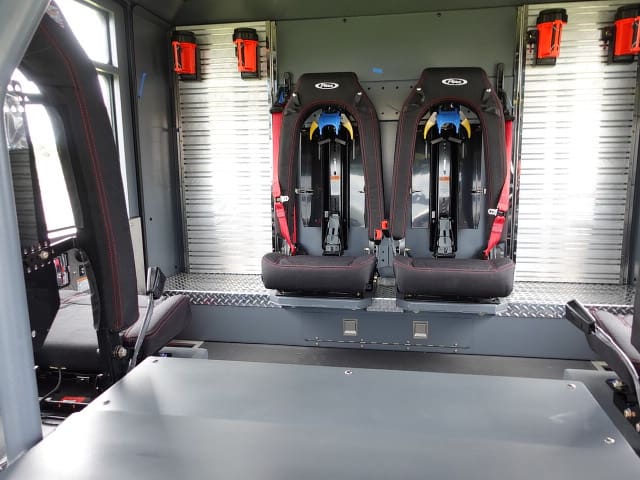

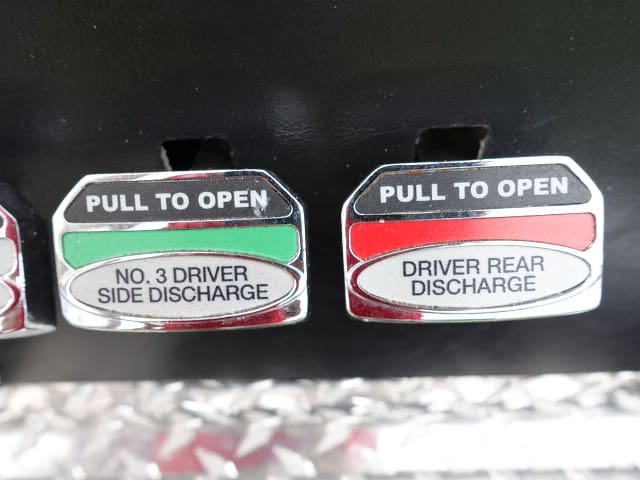

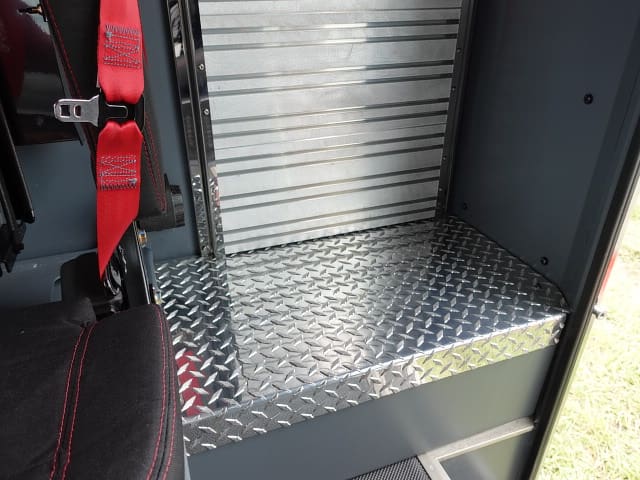

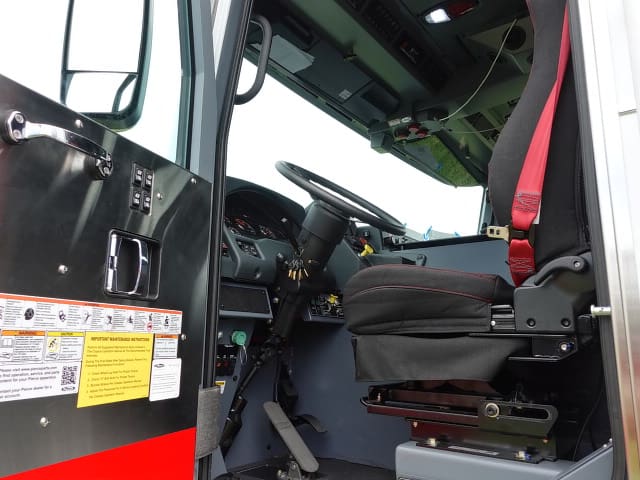

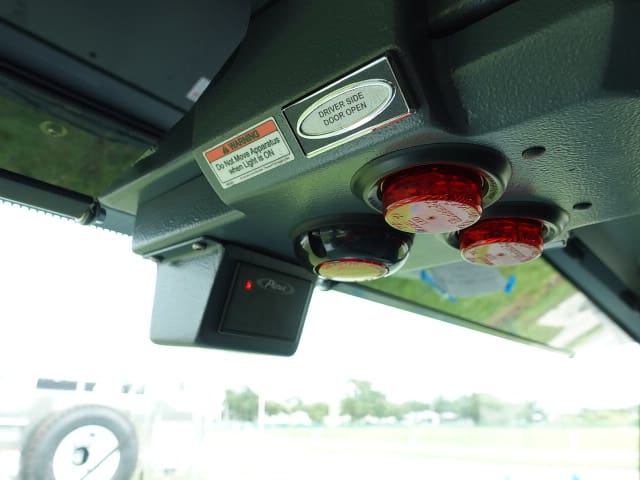

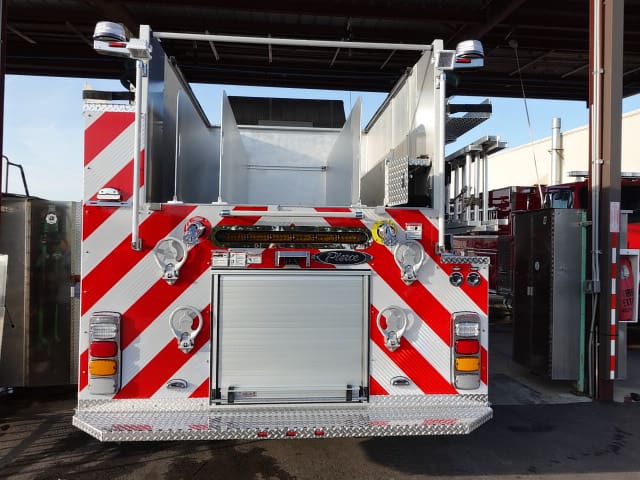

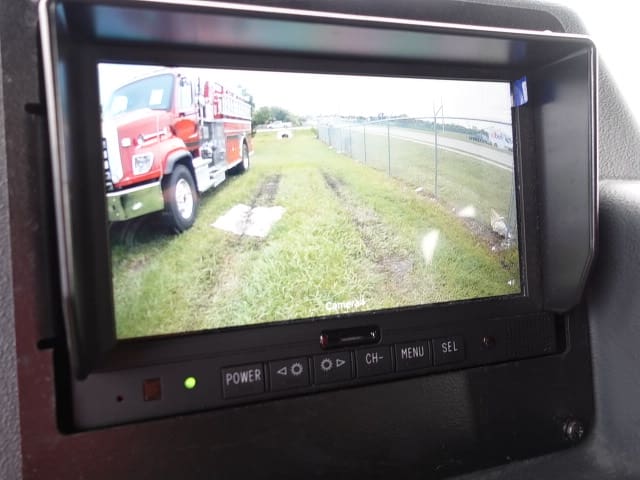

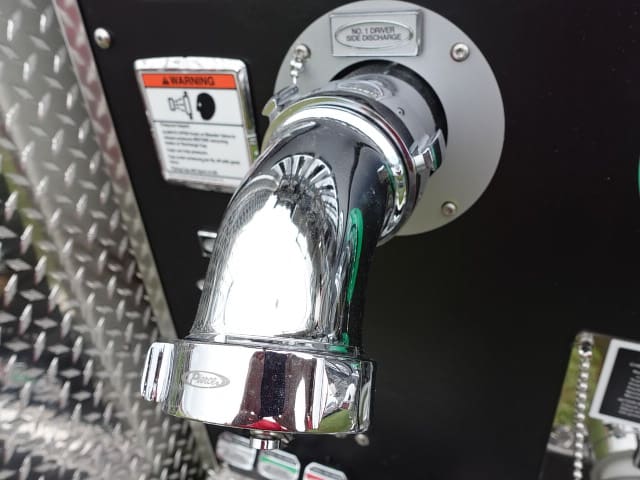

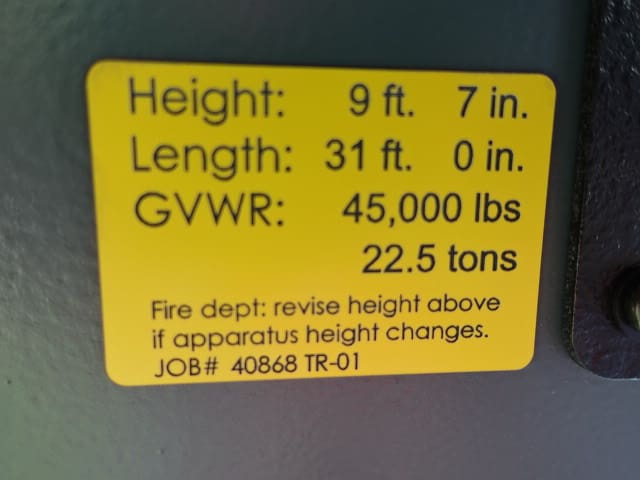

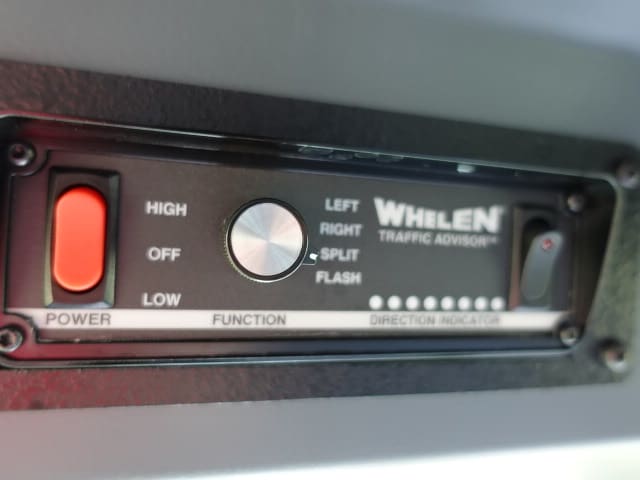

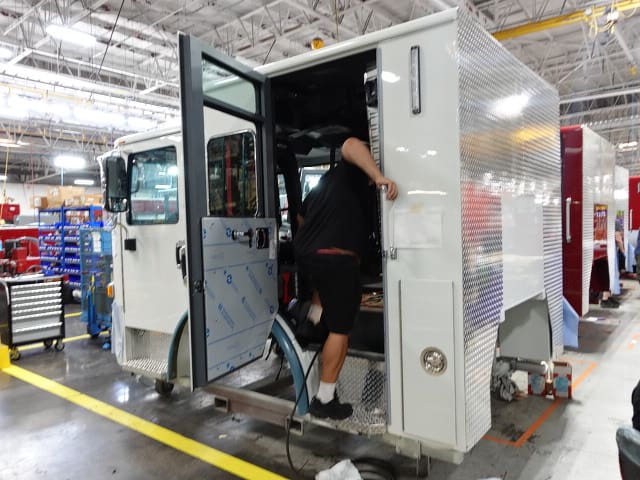

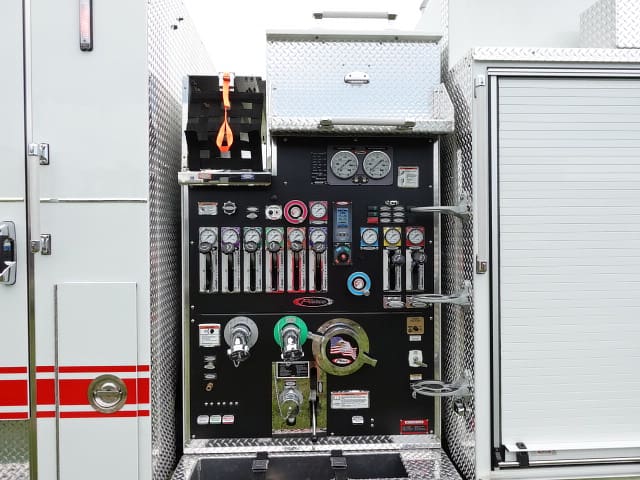

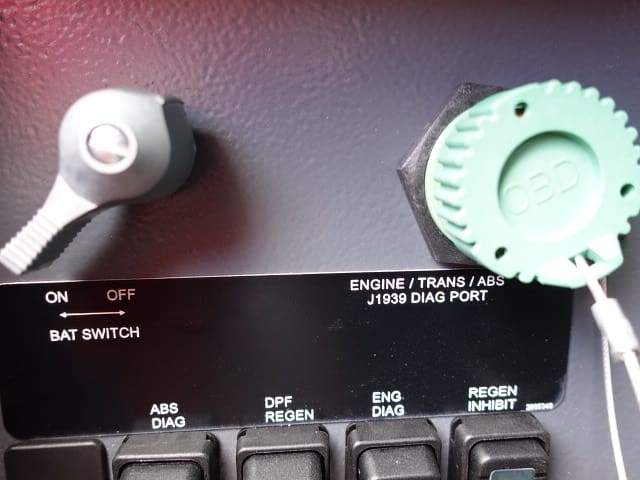

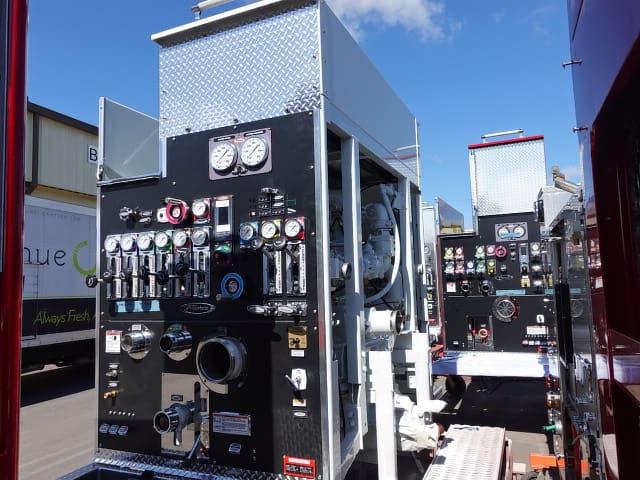

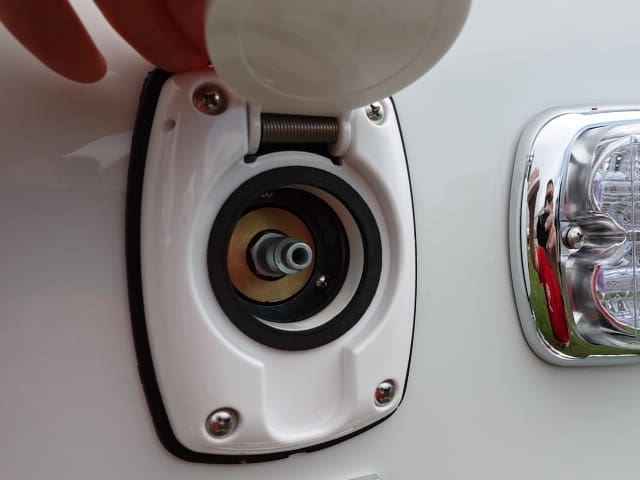

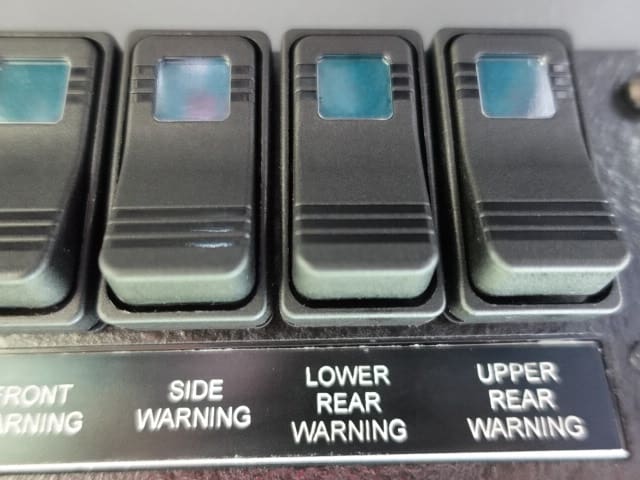

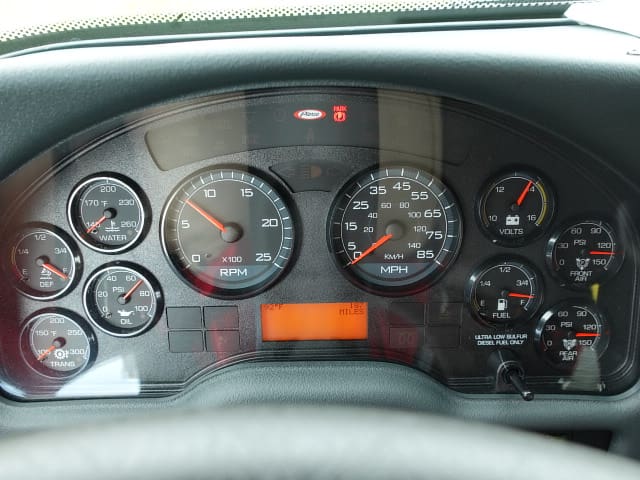

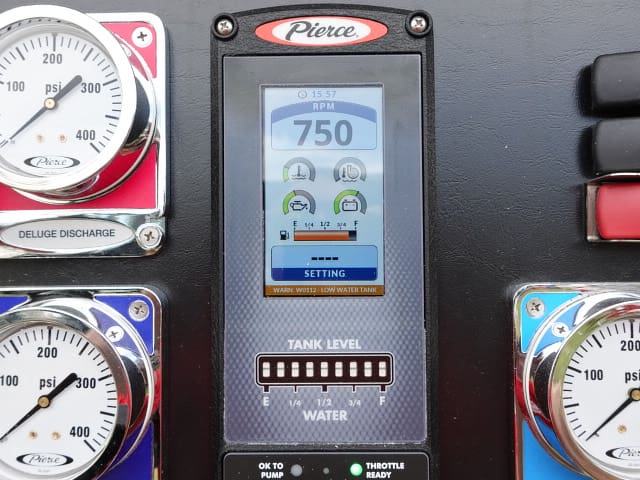

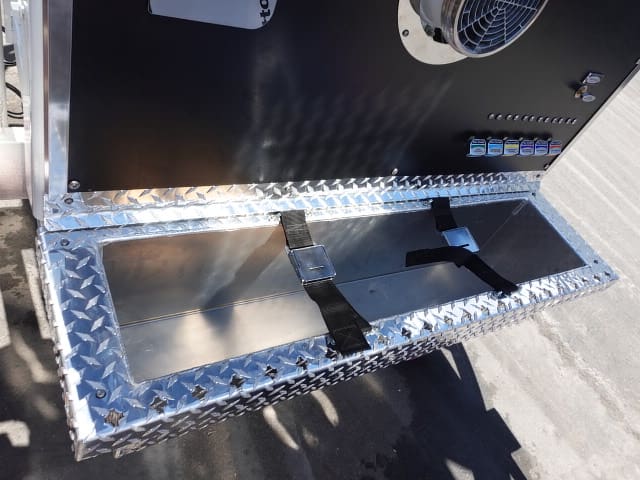

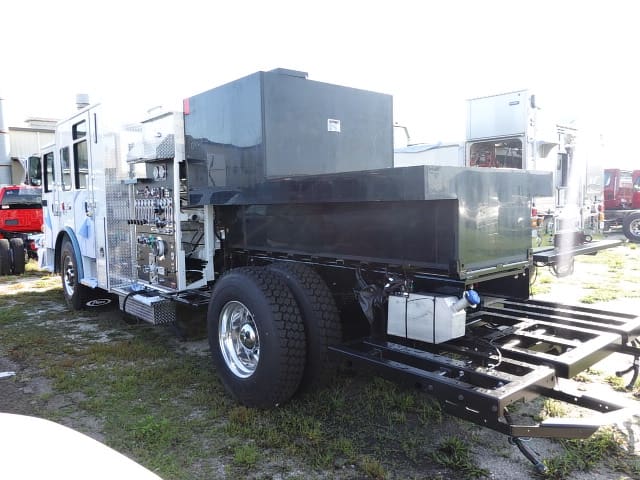

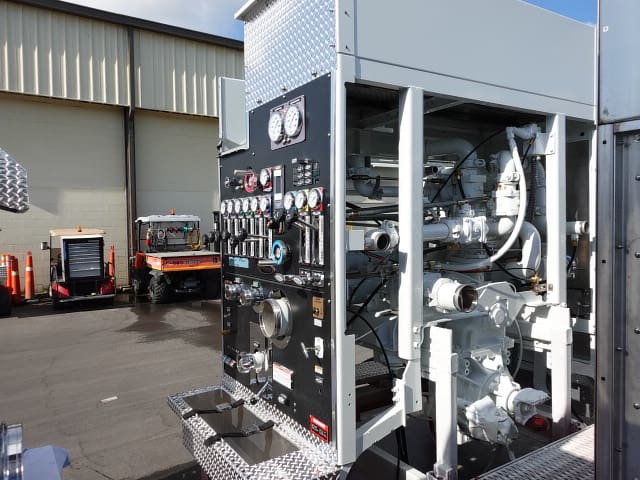

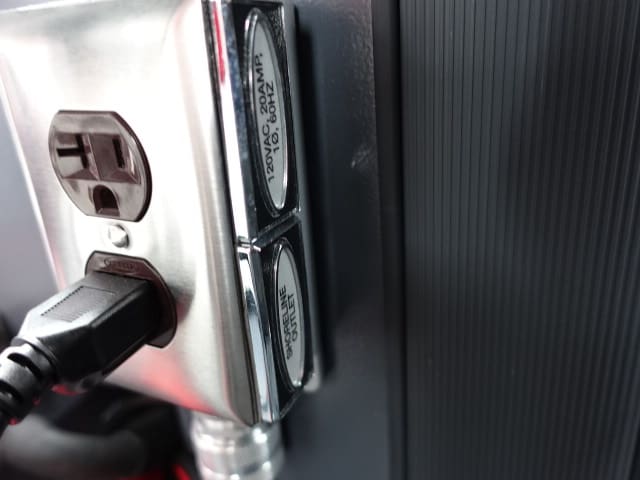

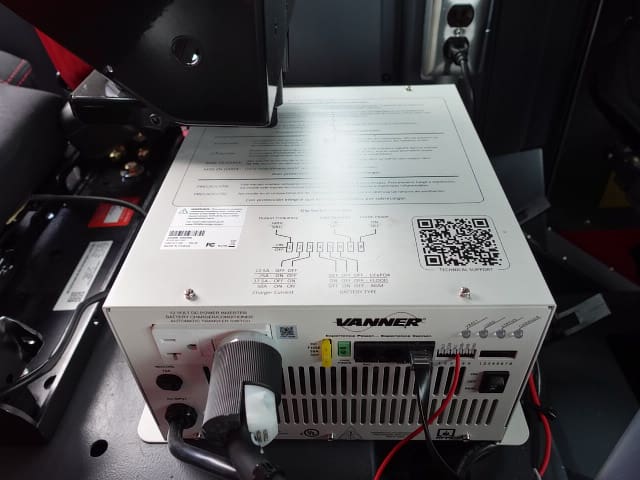

In this report, the apparatus completed testing followed by release to final product evaluation where any remaining content is applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
06-13-25

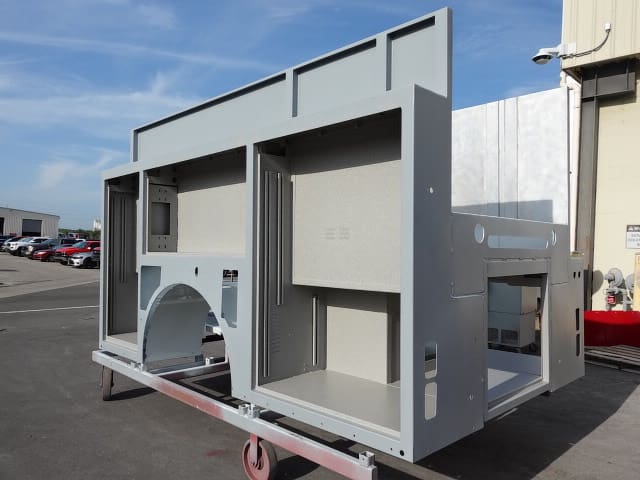

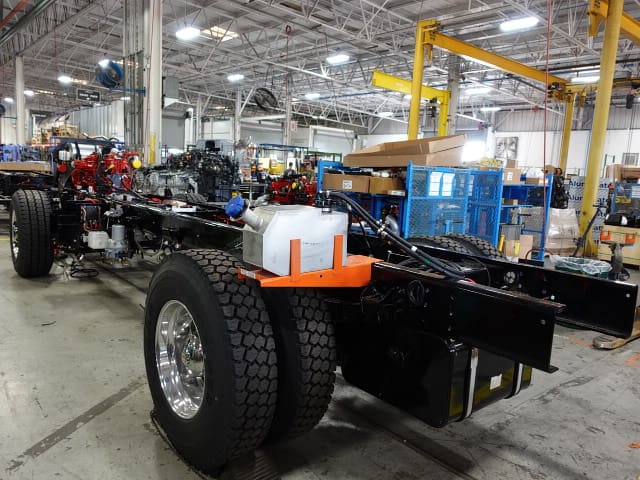

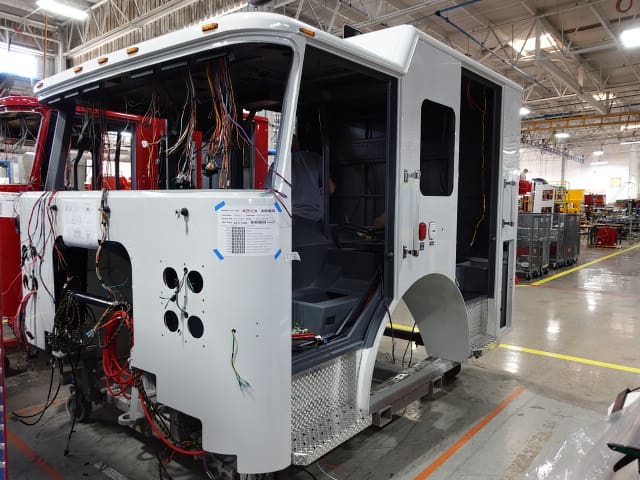

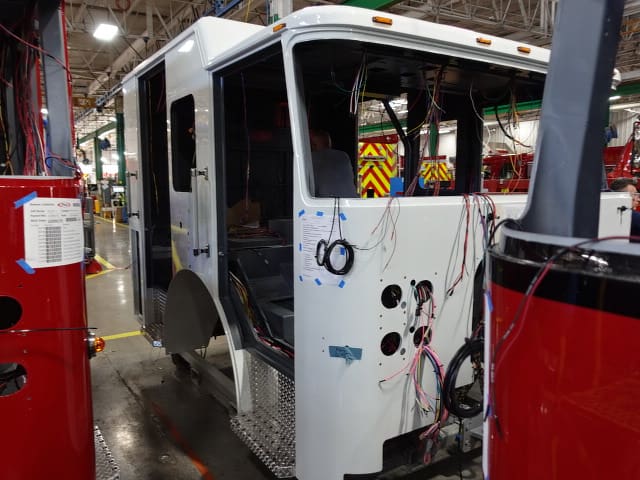

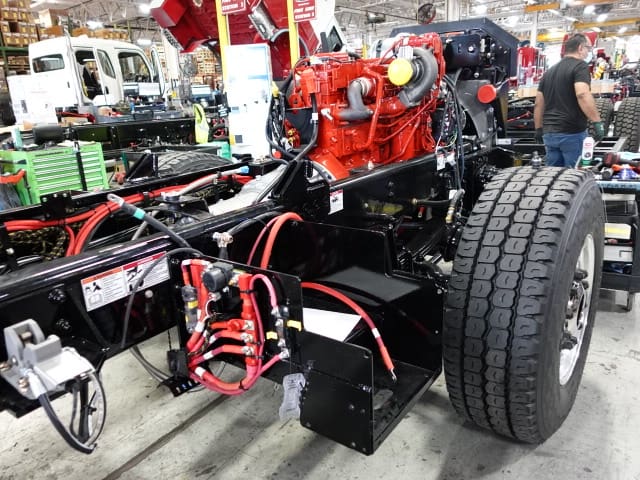

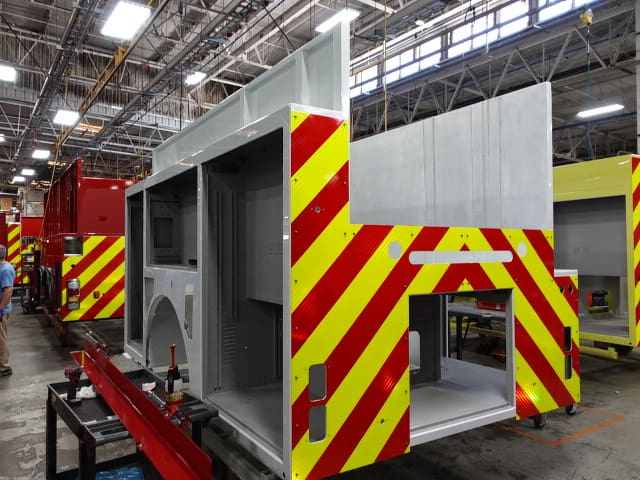

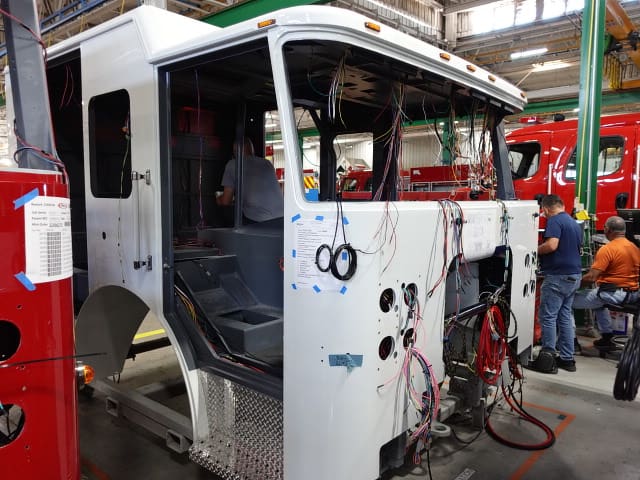

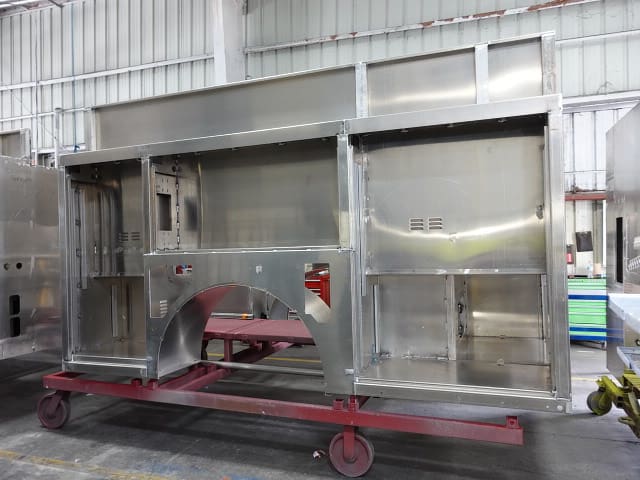

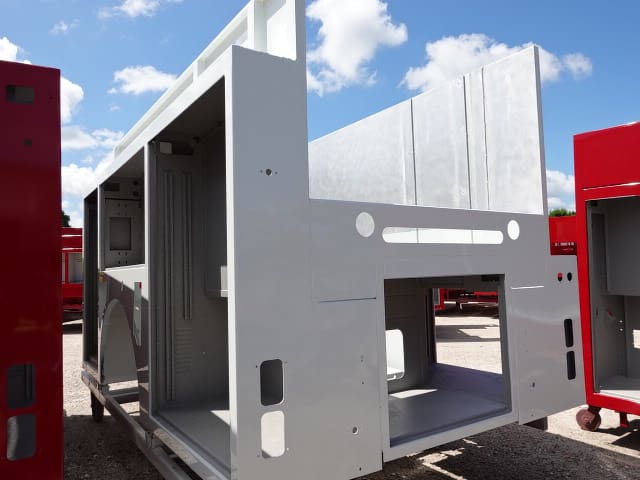

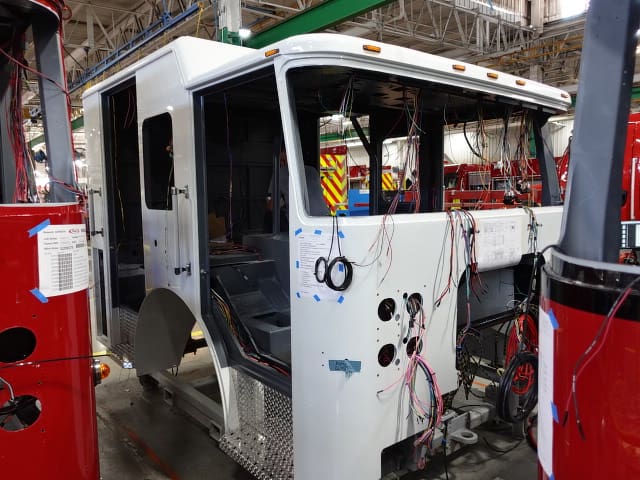

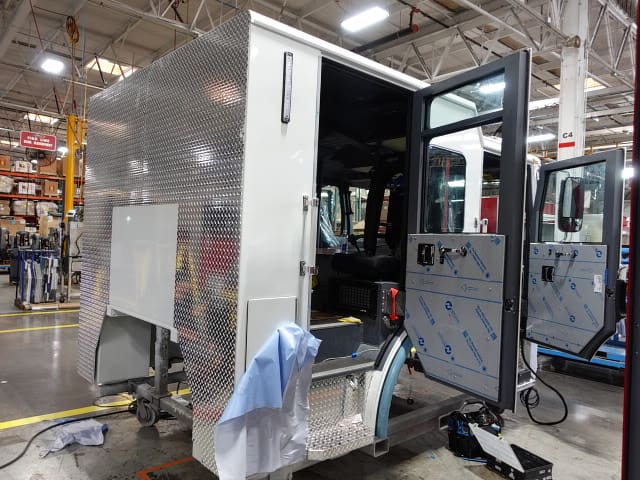

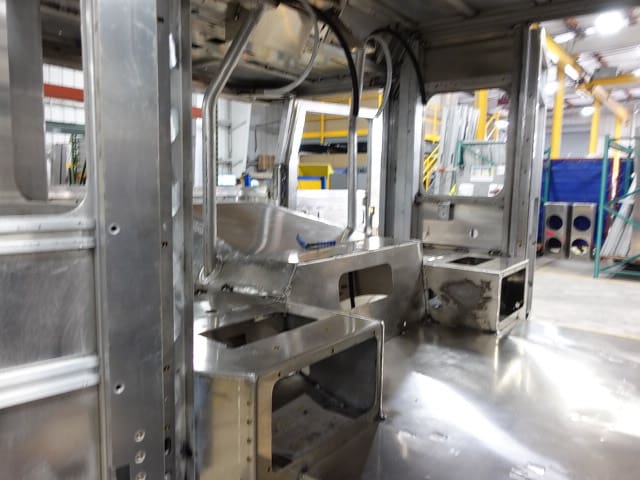

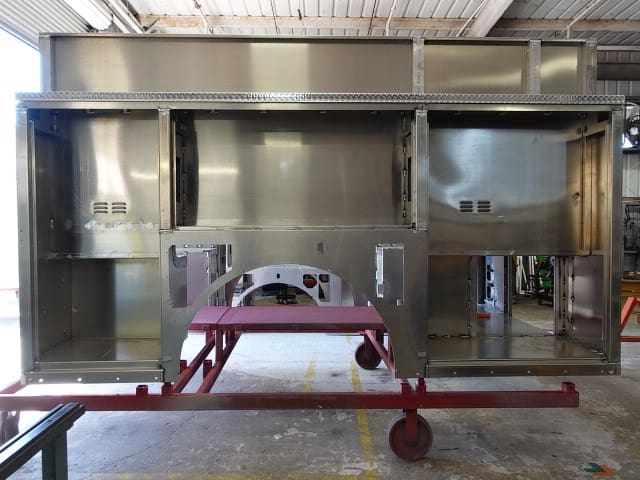

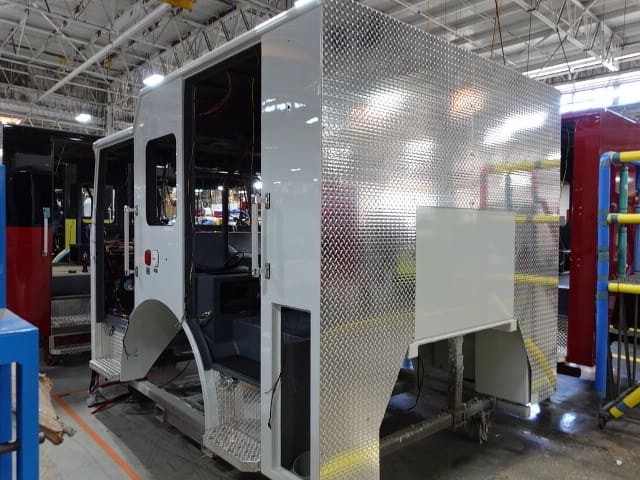

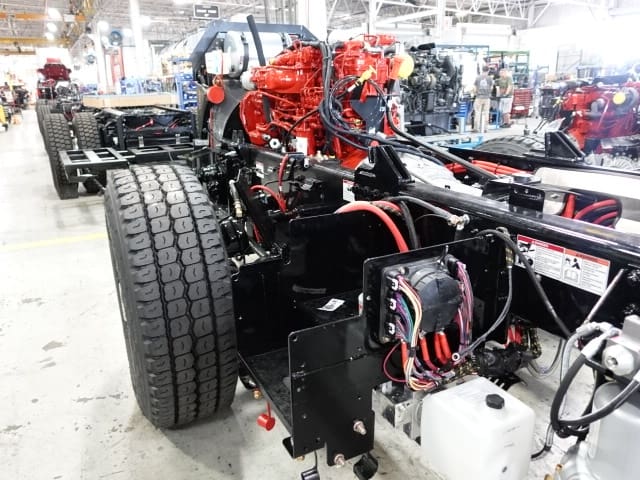

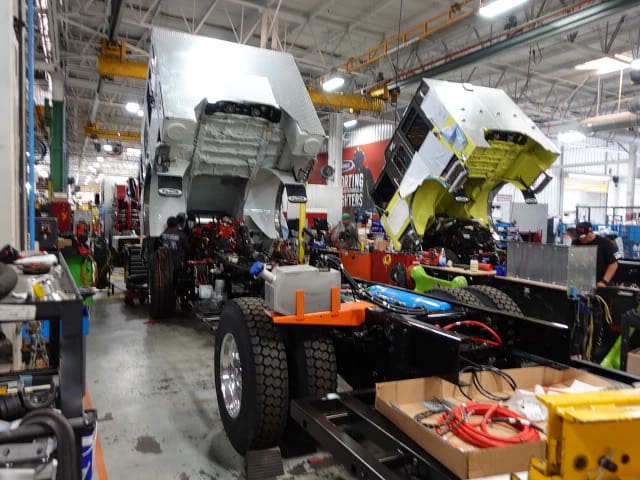

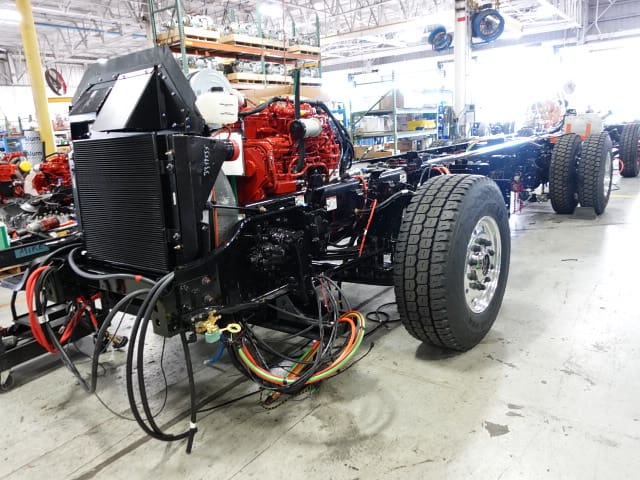

In this report, the body completed initial assembly and was merged with the chassis at the start of initial apparatus assembly.
06-06-25

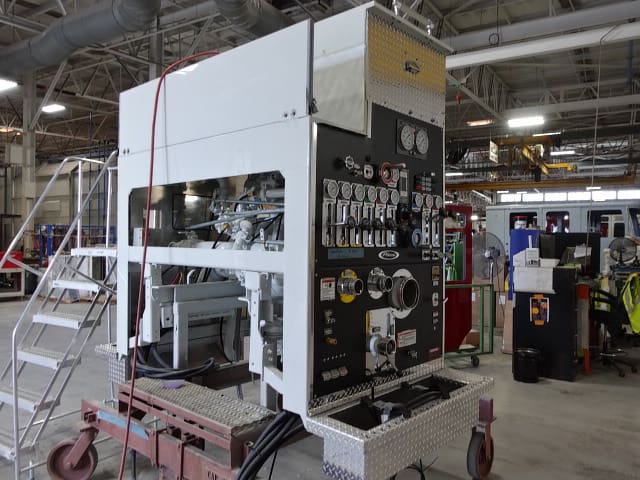

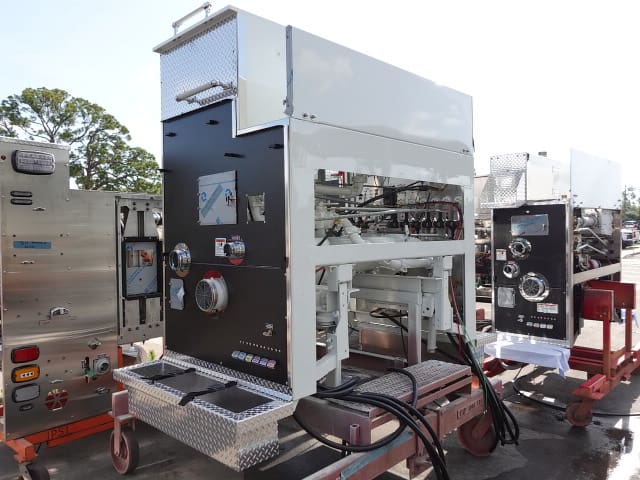

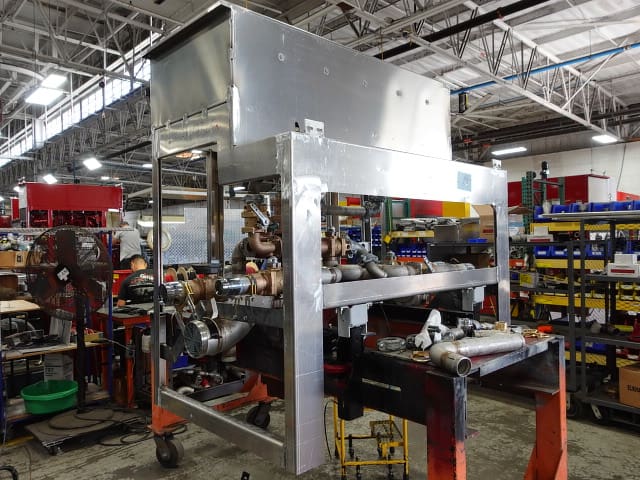

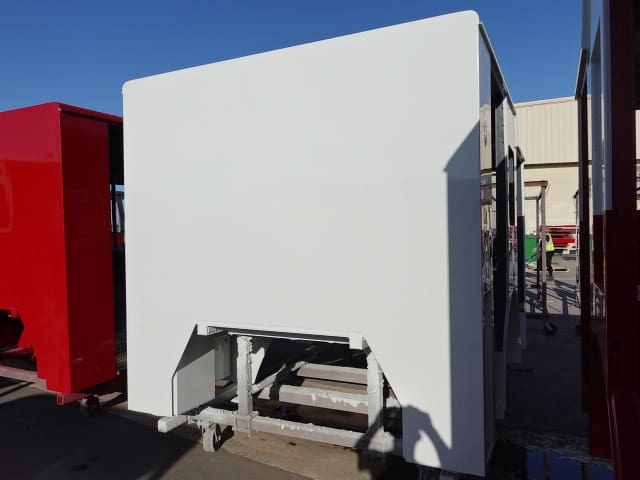

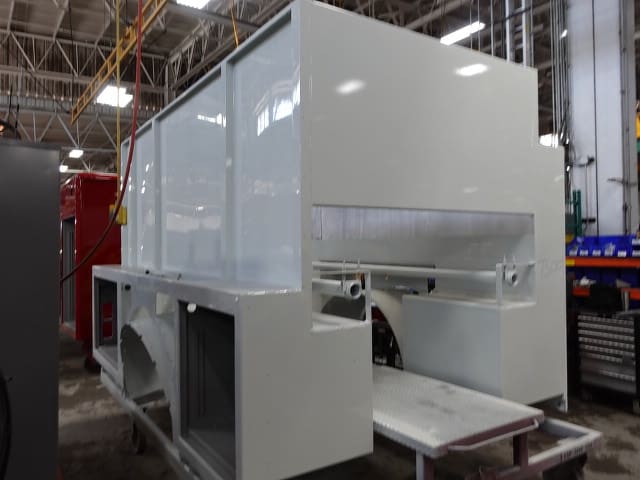

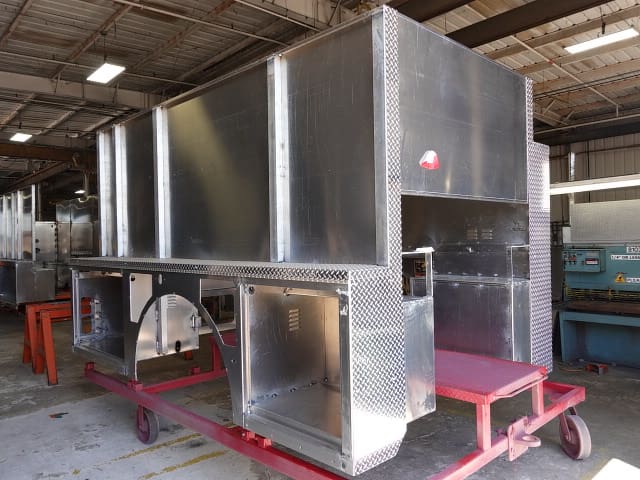

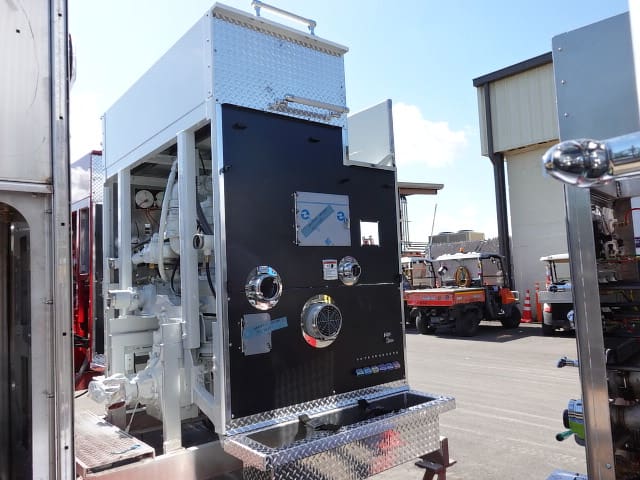

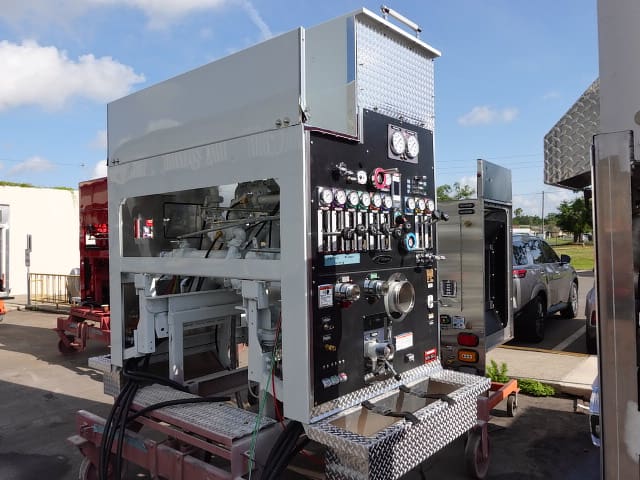

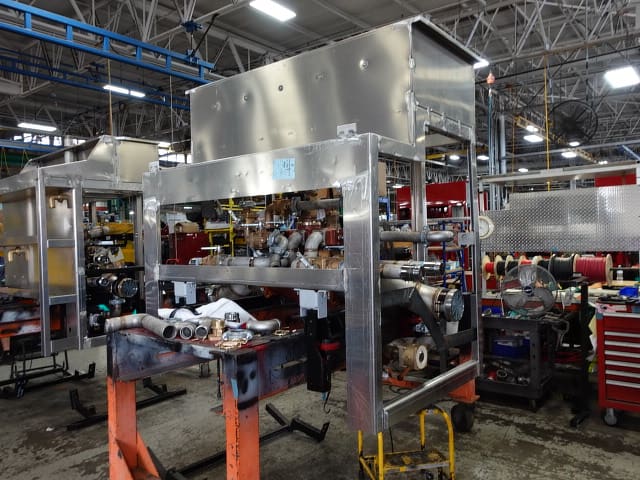

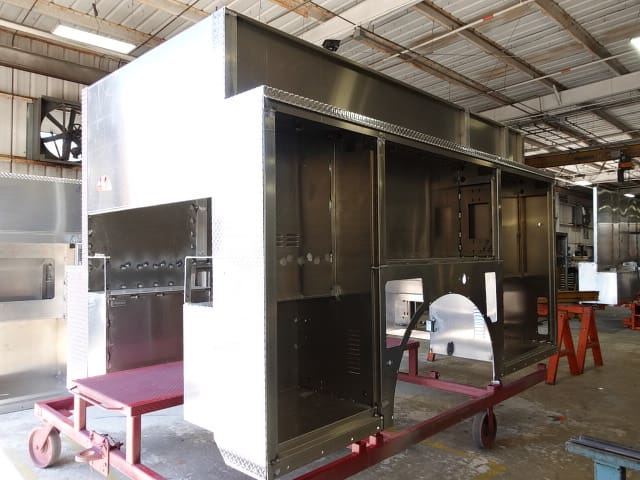

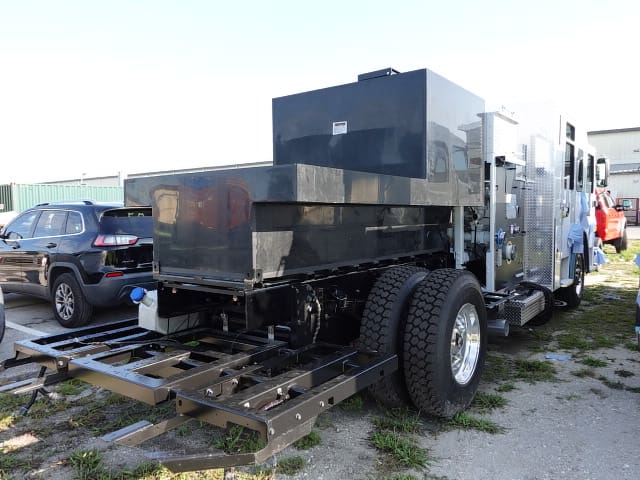

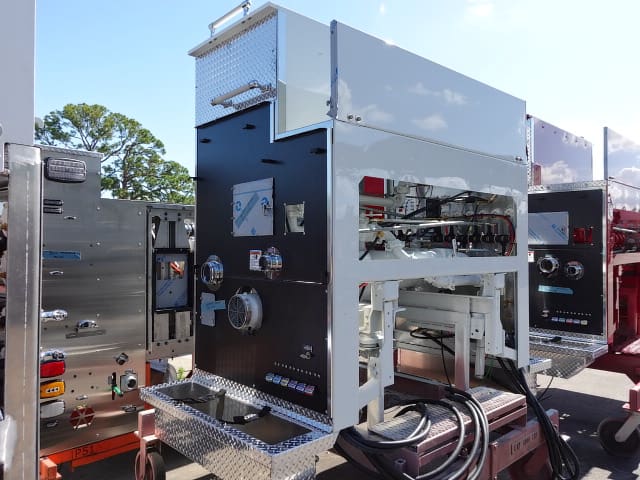

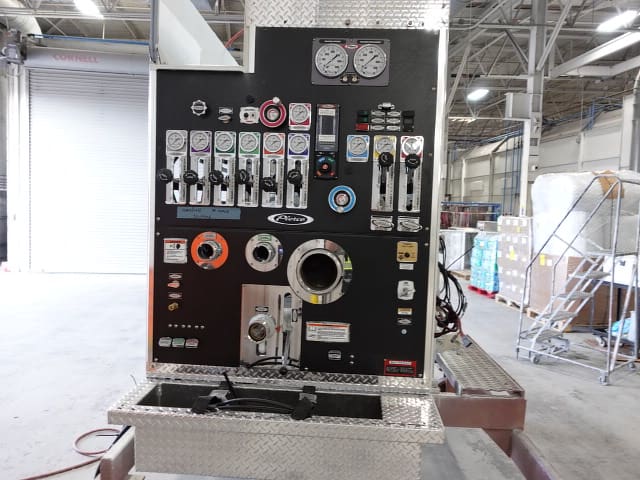

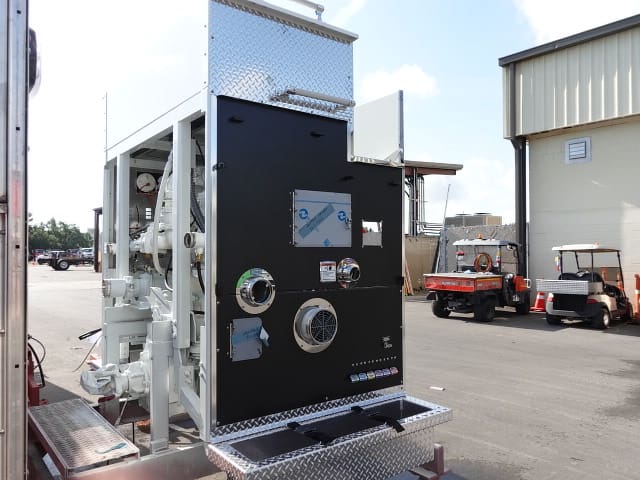

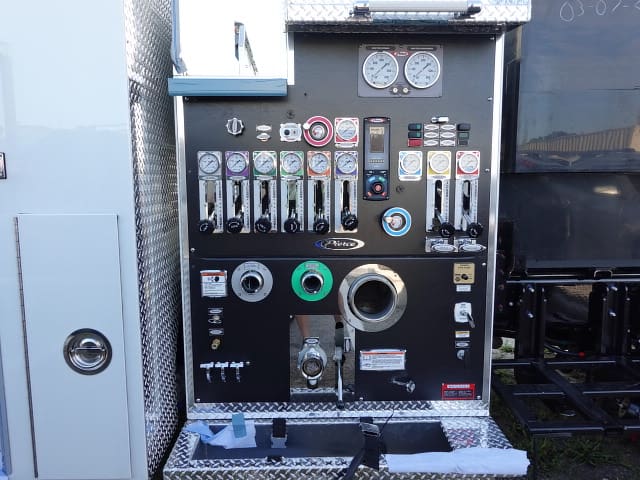

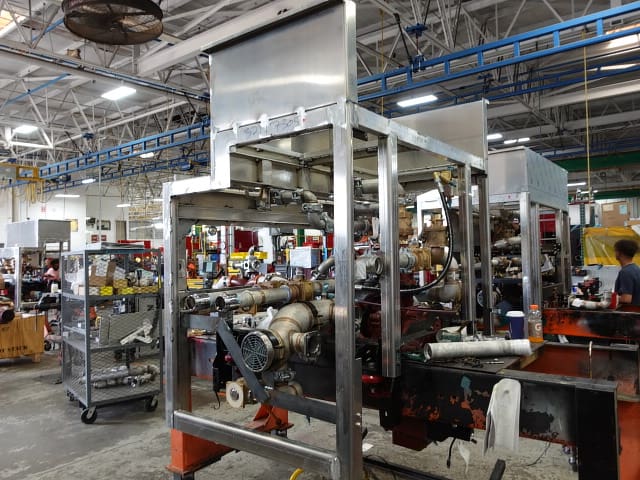

In this report, the pump house completed assembly and was installed on the chassis along with the tank while the body continued initial assembly.

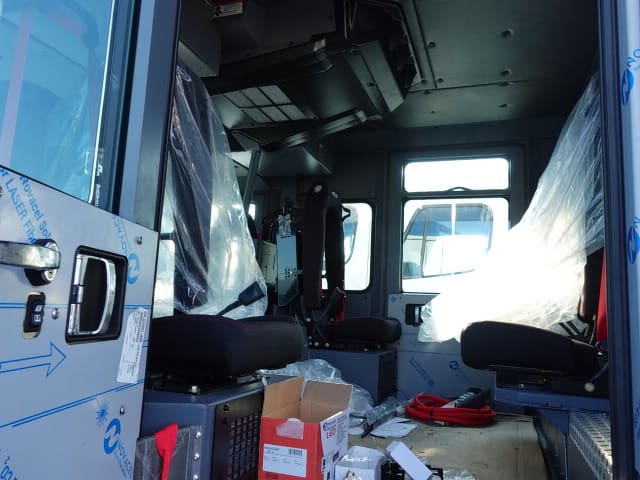

05-30-25

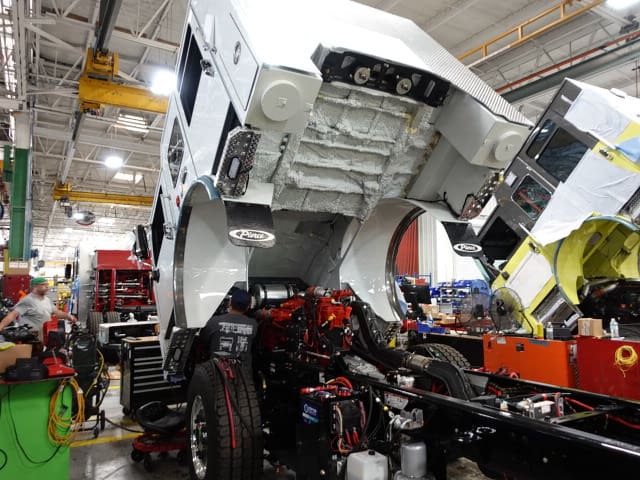

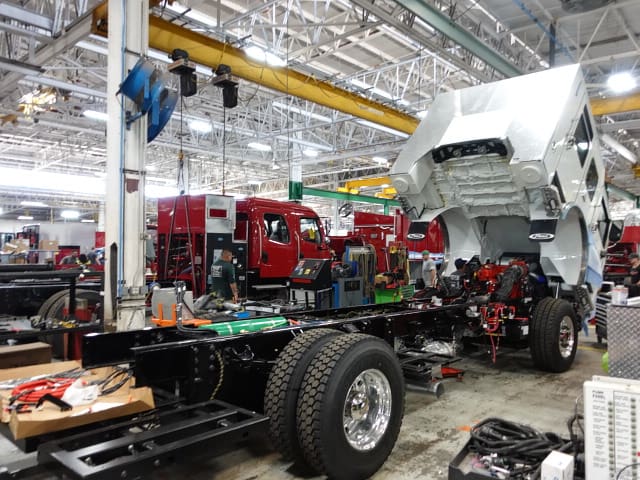

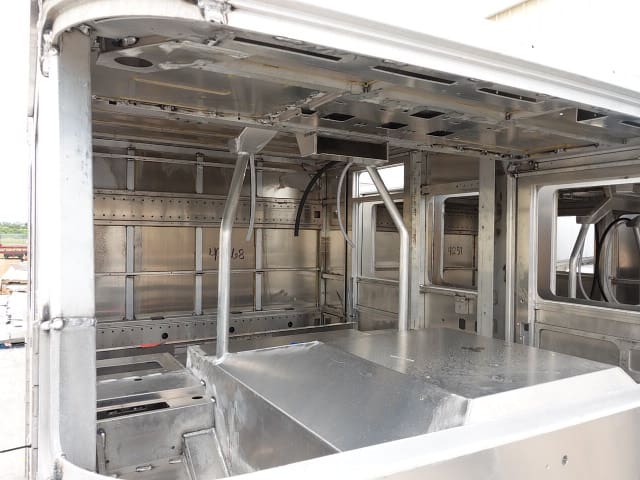

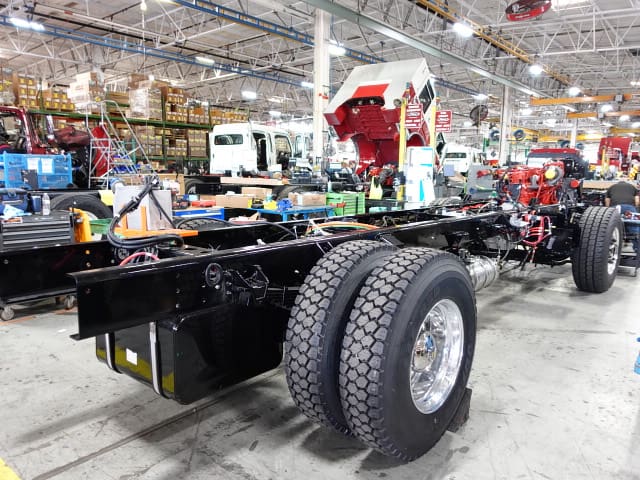

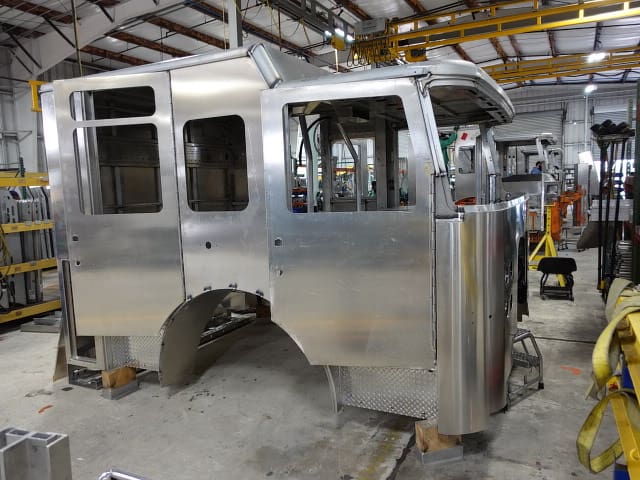

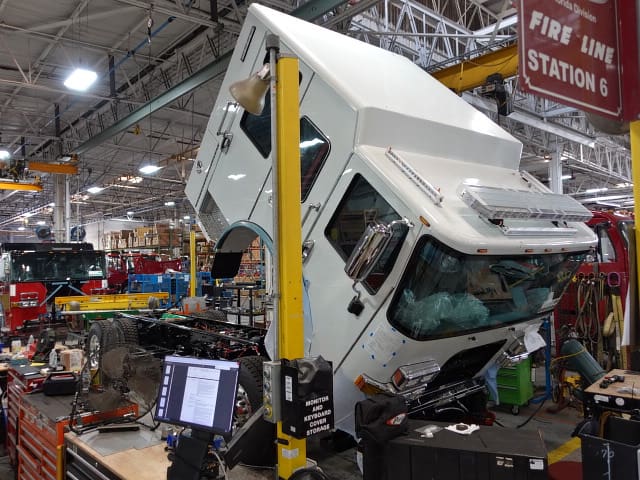

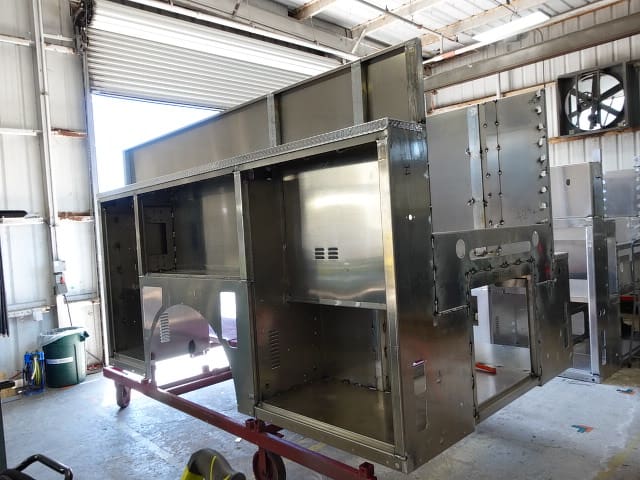

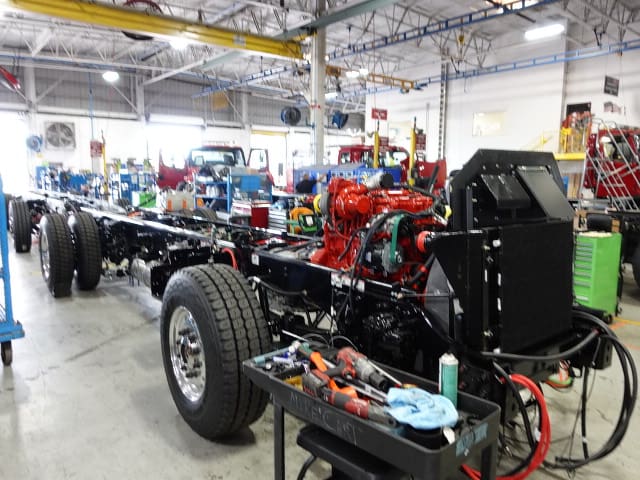

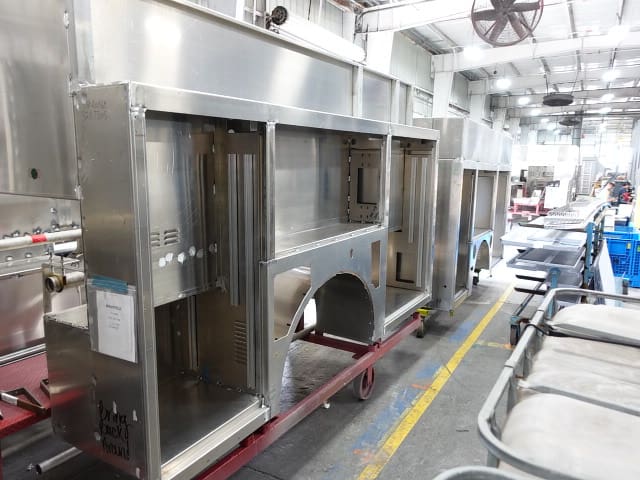

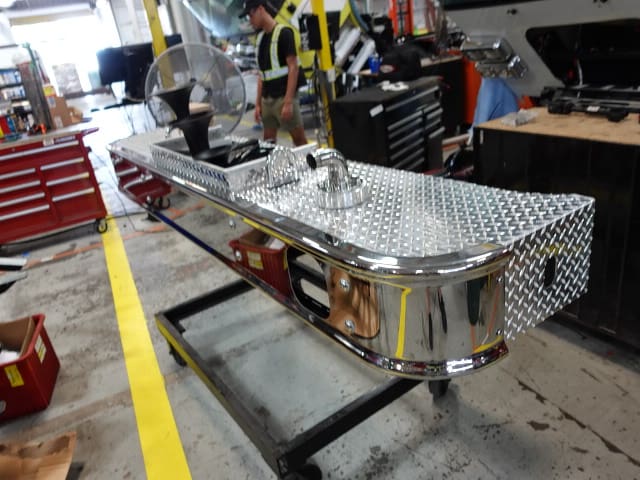

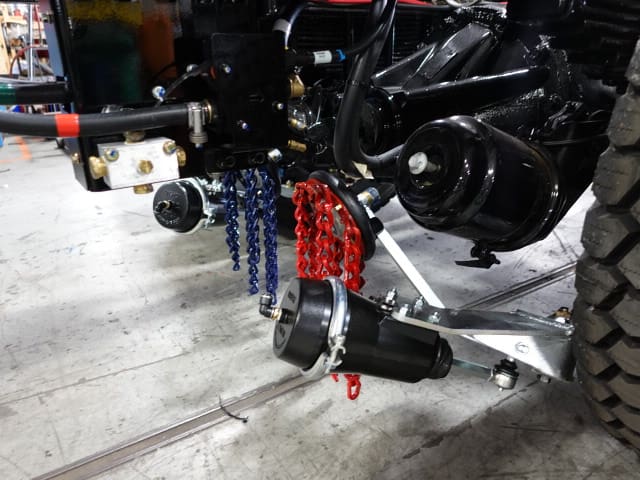

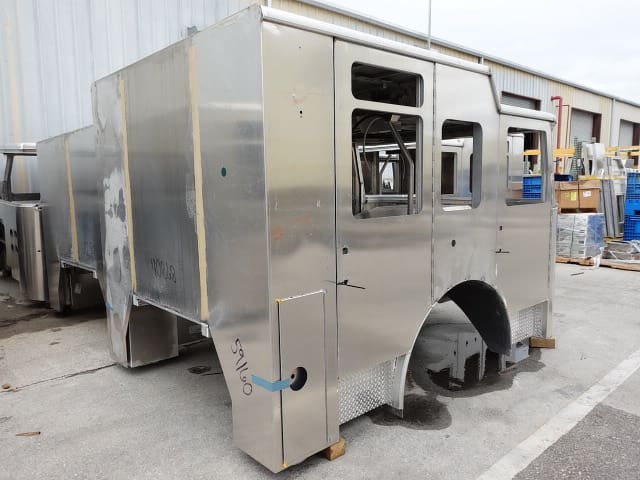

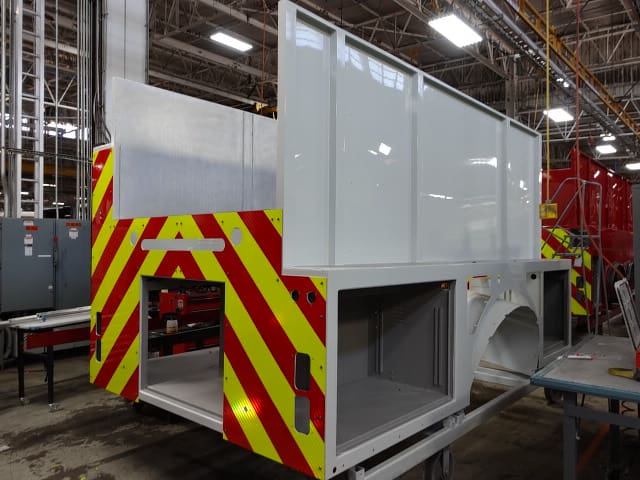

In this report, the cab completed initial assembly and was merged with the frame, the pump continued assembly, and the body began initial assembly.
05-23-25
In this report, the cab continued initial assembly, the frame build continued, the pump remained staged, and the body was staged (no photos).
05-16-25

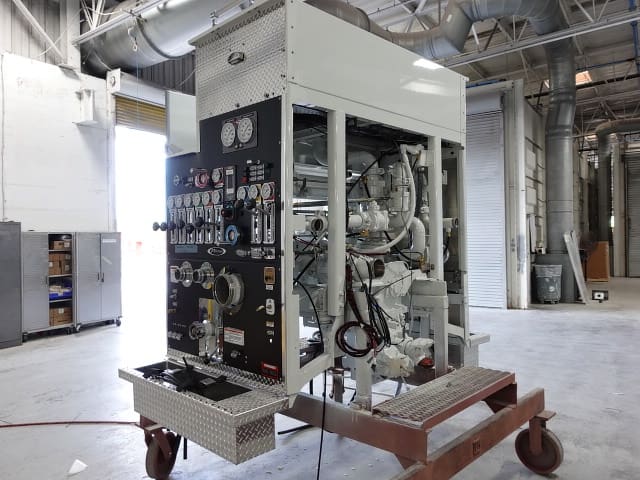

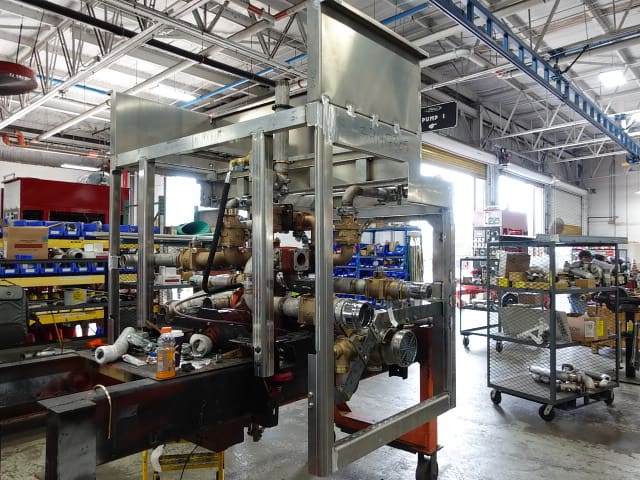

In this report, the cab began initial assembly, the frame remained staged (no photos), the pump completed initial assembly, and the body remained staged.

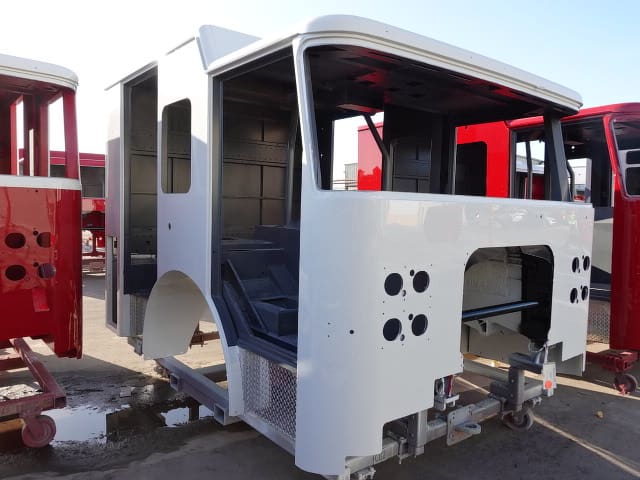

05-02-25

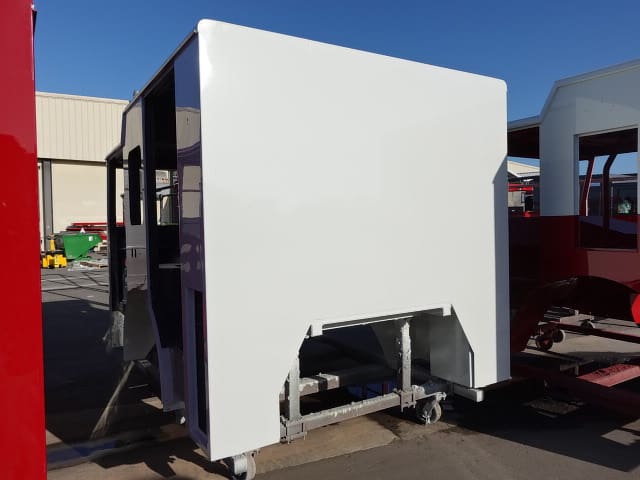

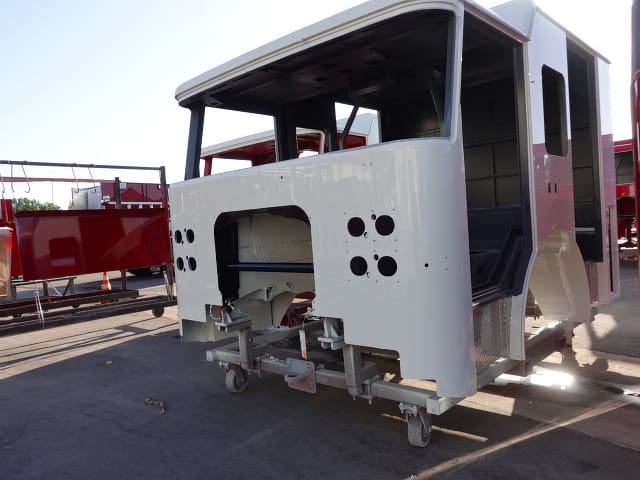

In this report, the cab completed paint, the frame was staged (no photos), the pump was painted, and the body continued through paint and was staged.

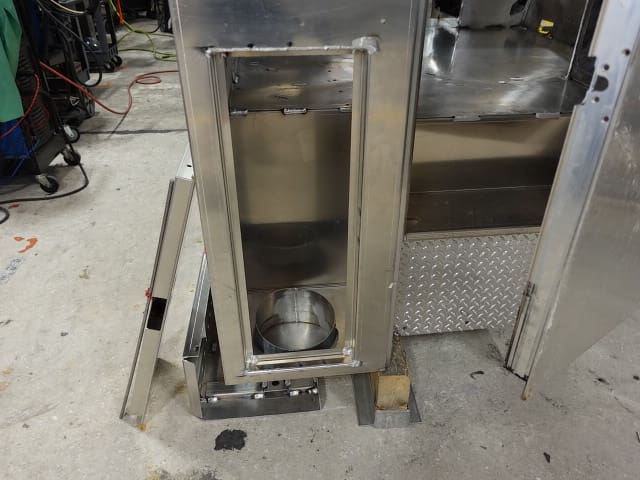

04-25-25

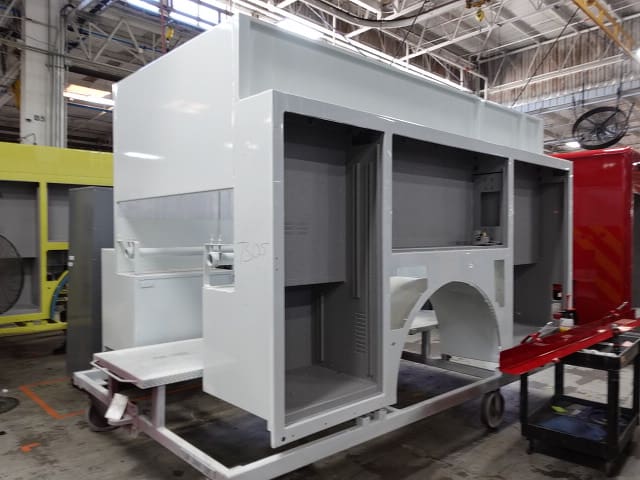

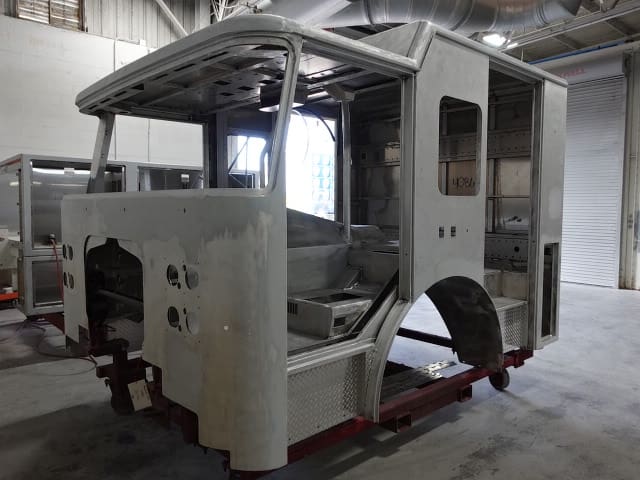

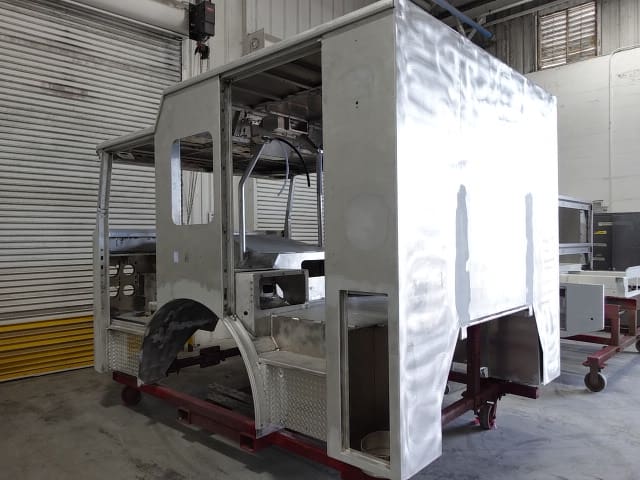

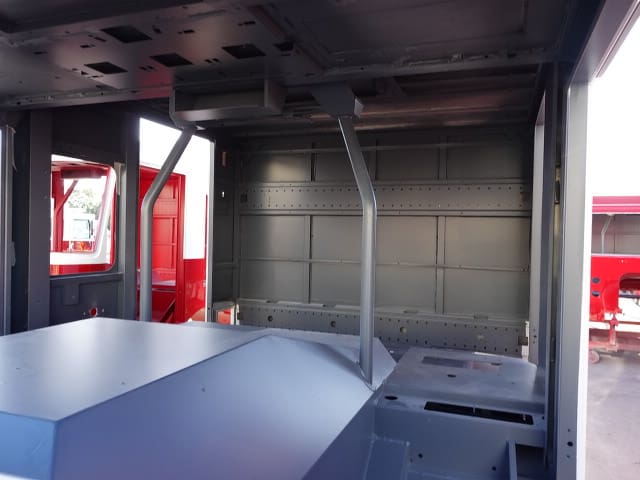

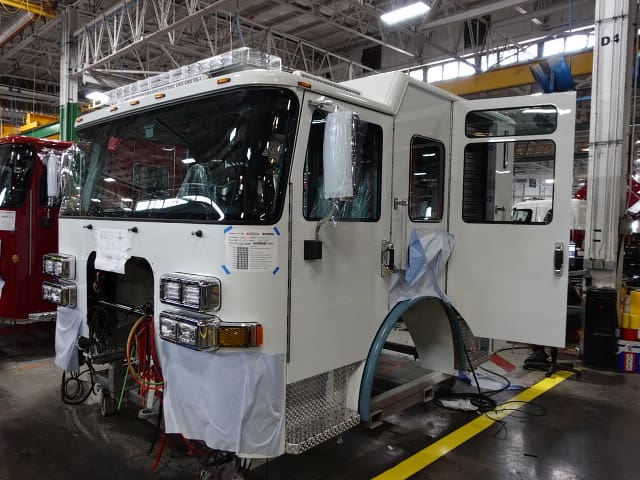

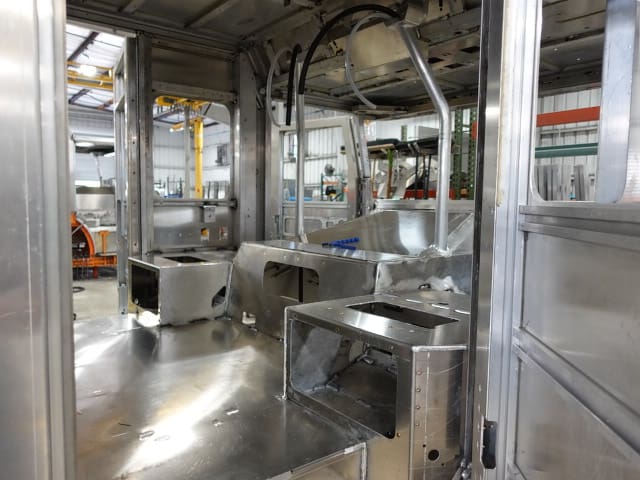

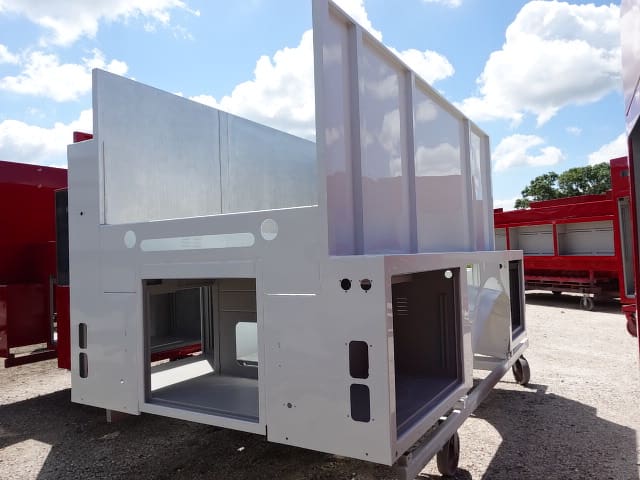

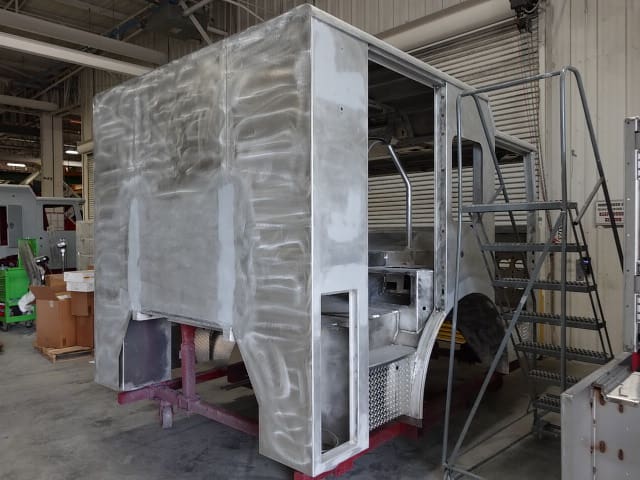

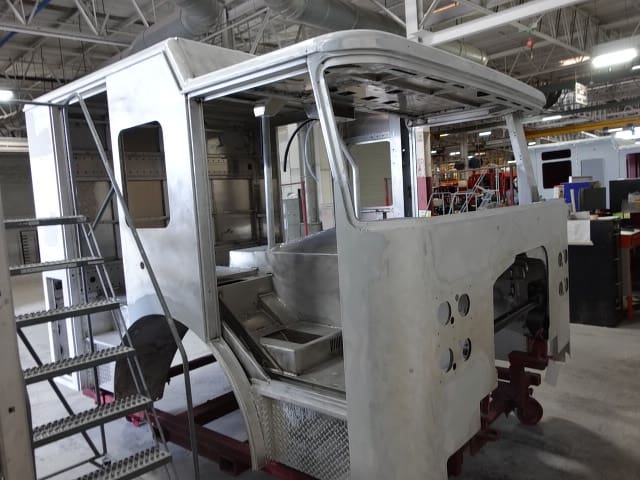

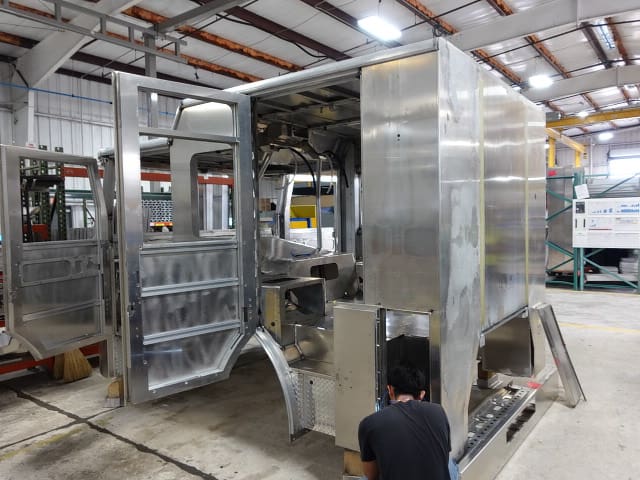

In this report, the cab began the paint process with metal finishing, the frame build began, the pump house began initial assembly, and the body completed fabrication and began in paint.
04-11-25

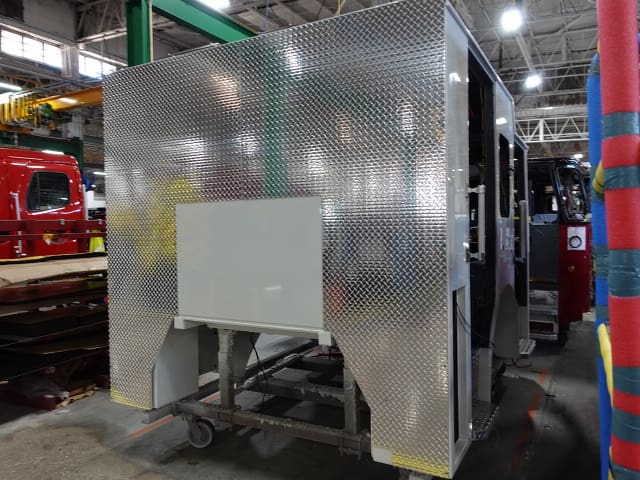

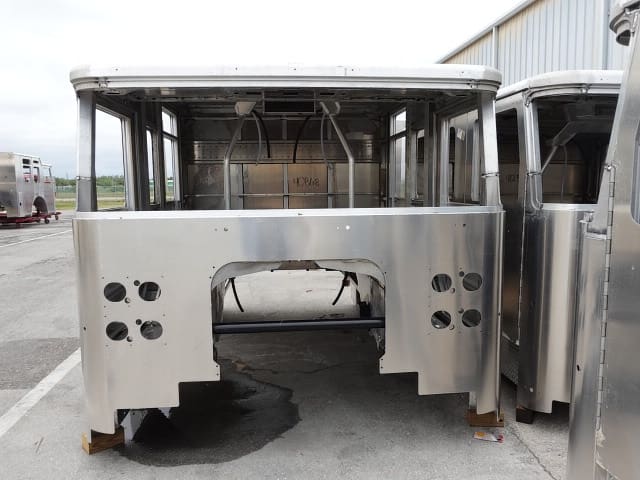

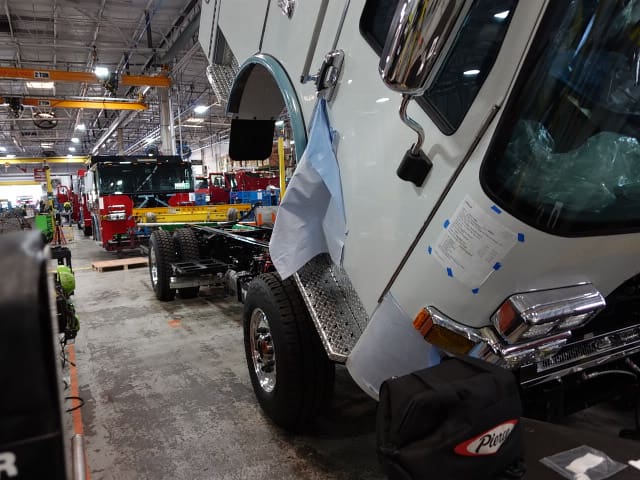

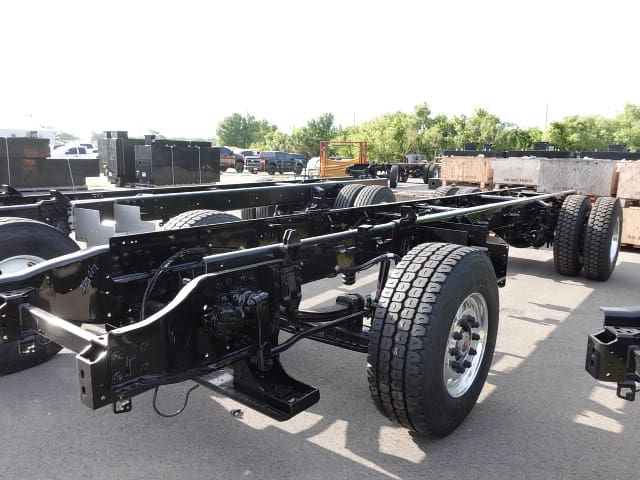

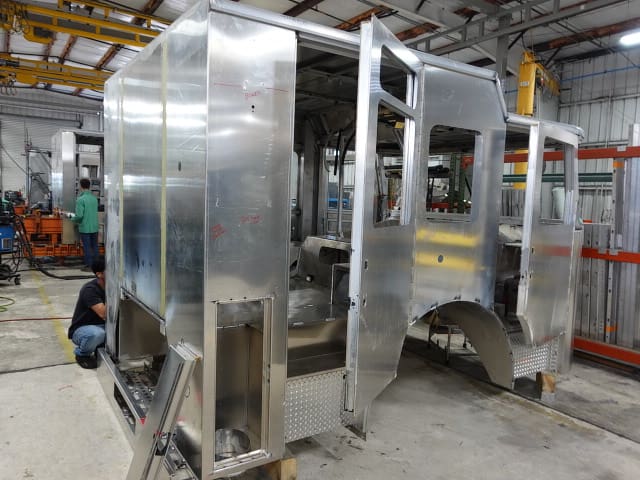

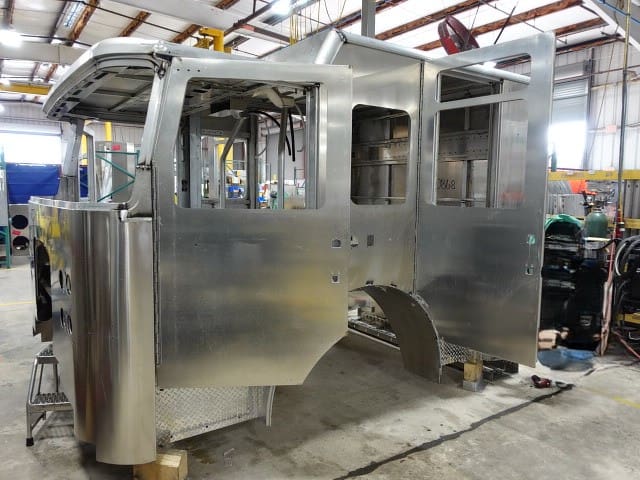

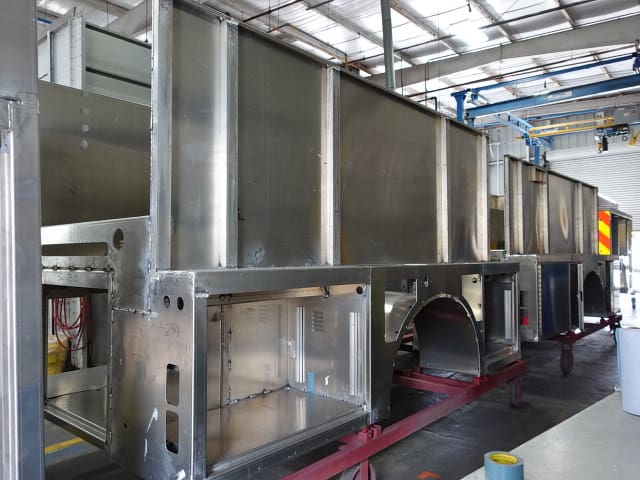

In this report, the cab completed the fabrication process while the body continued fabrication.
04-04-25

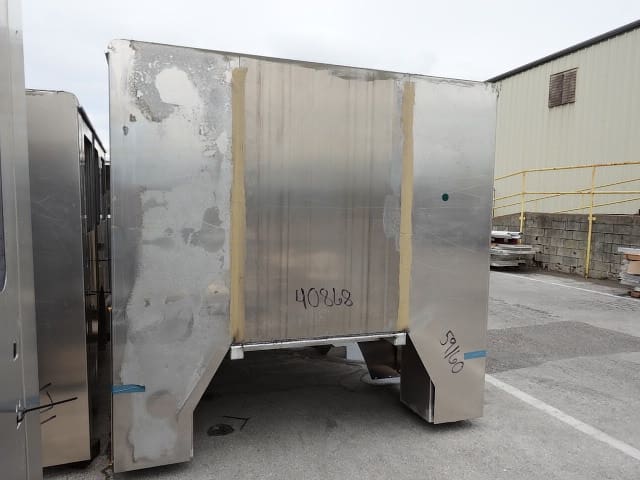

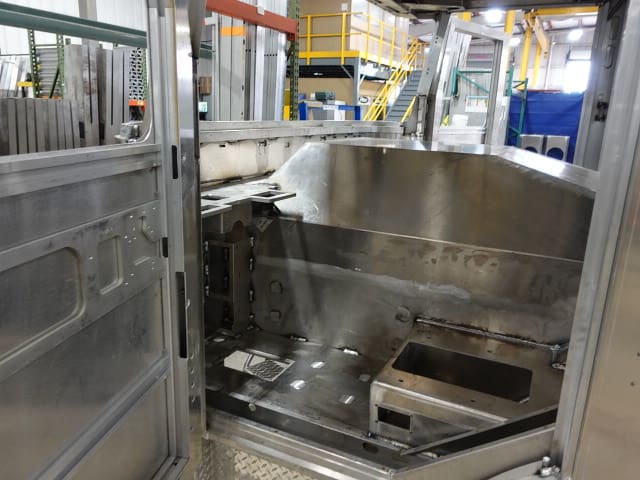

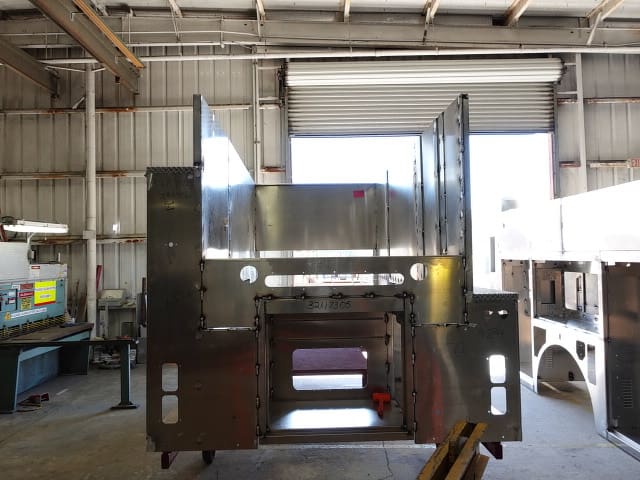

In this report, the cab began fabrication while the body continued the fabrication process.

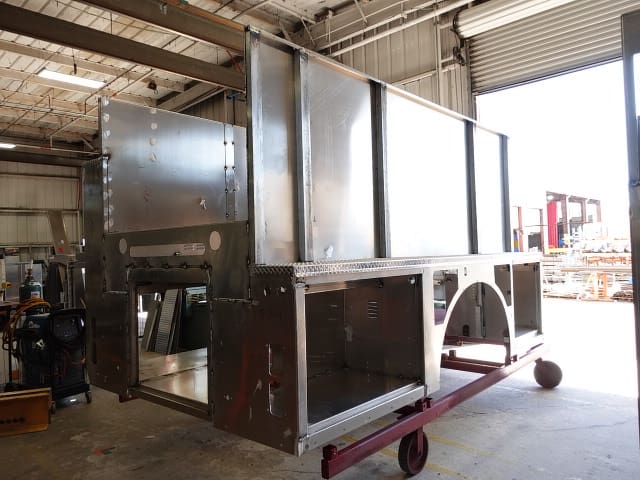

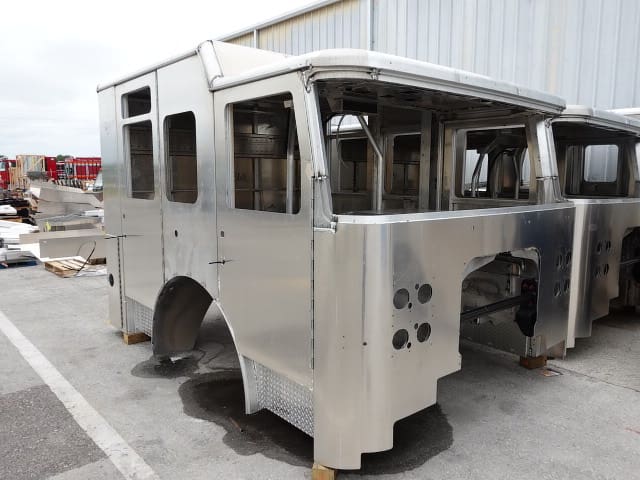

03-28-25

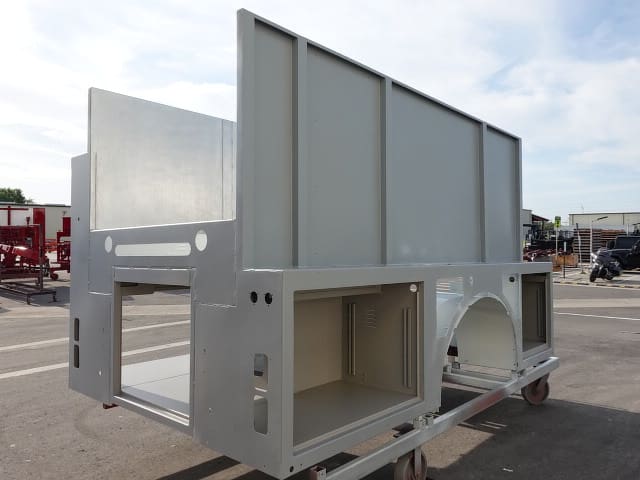

This new Pierce apparatus is now in production! In this report, the body began fabrication.
