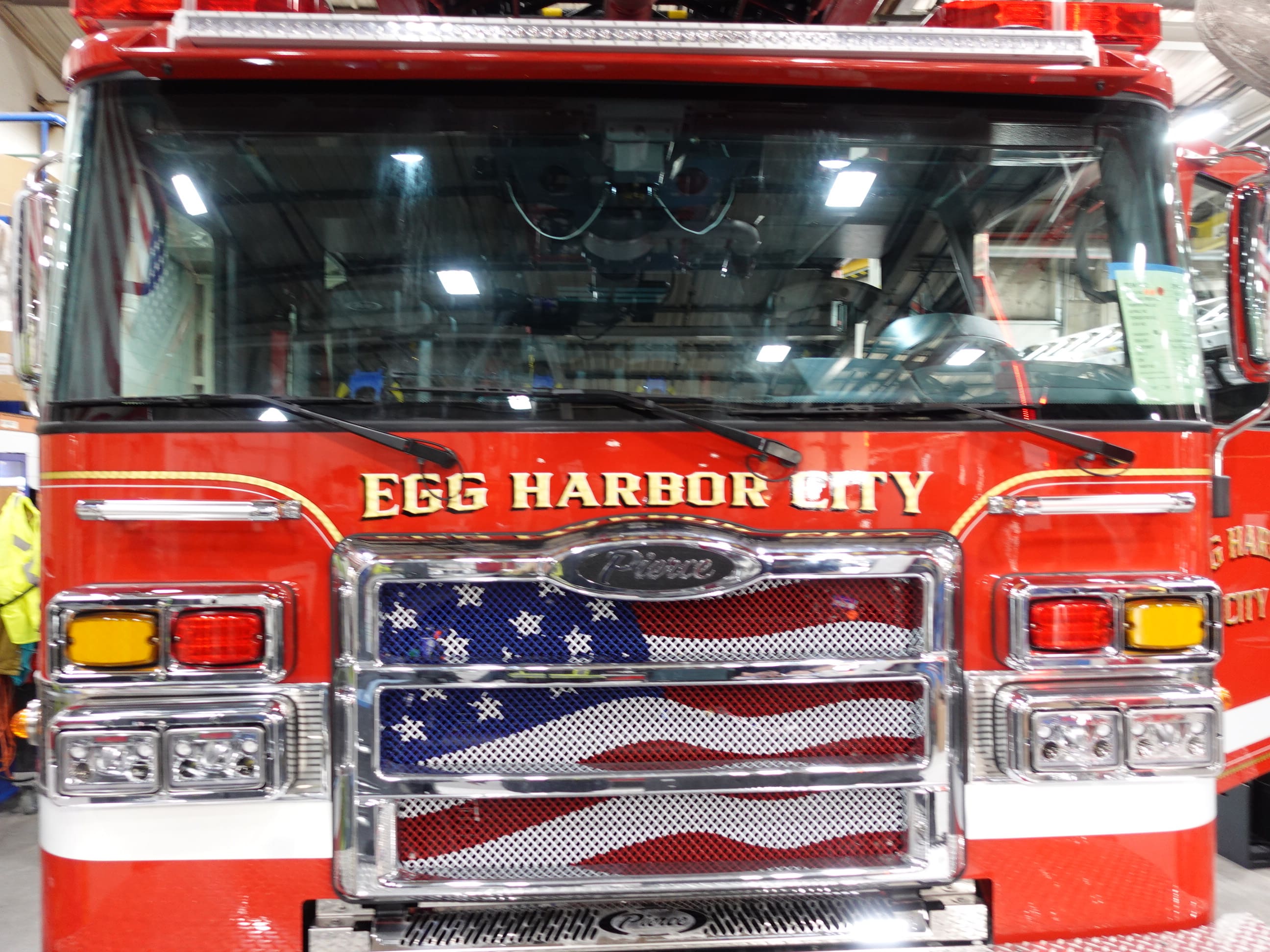

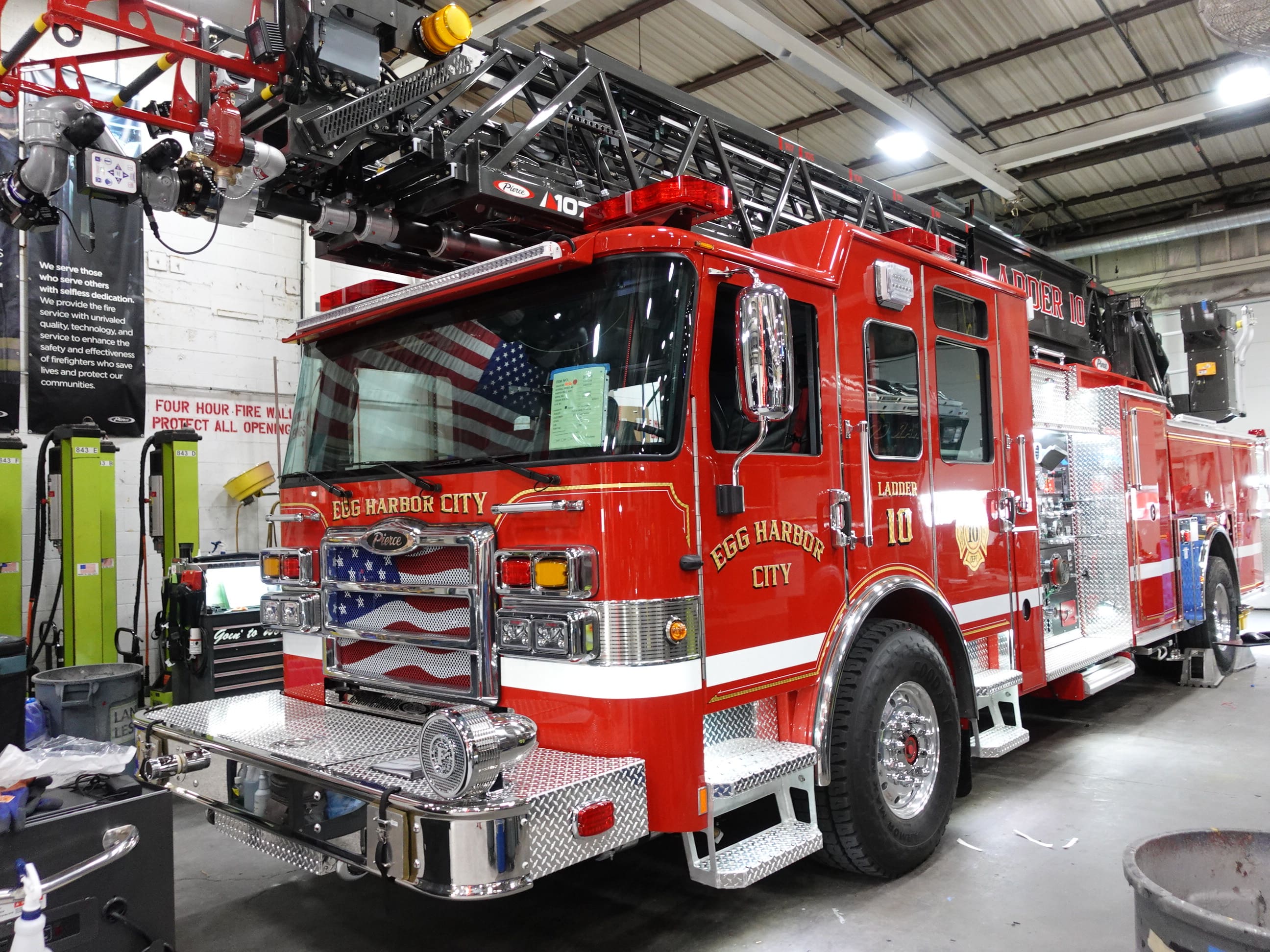

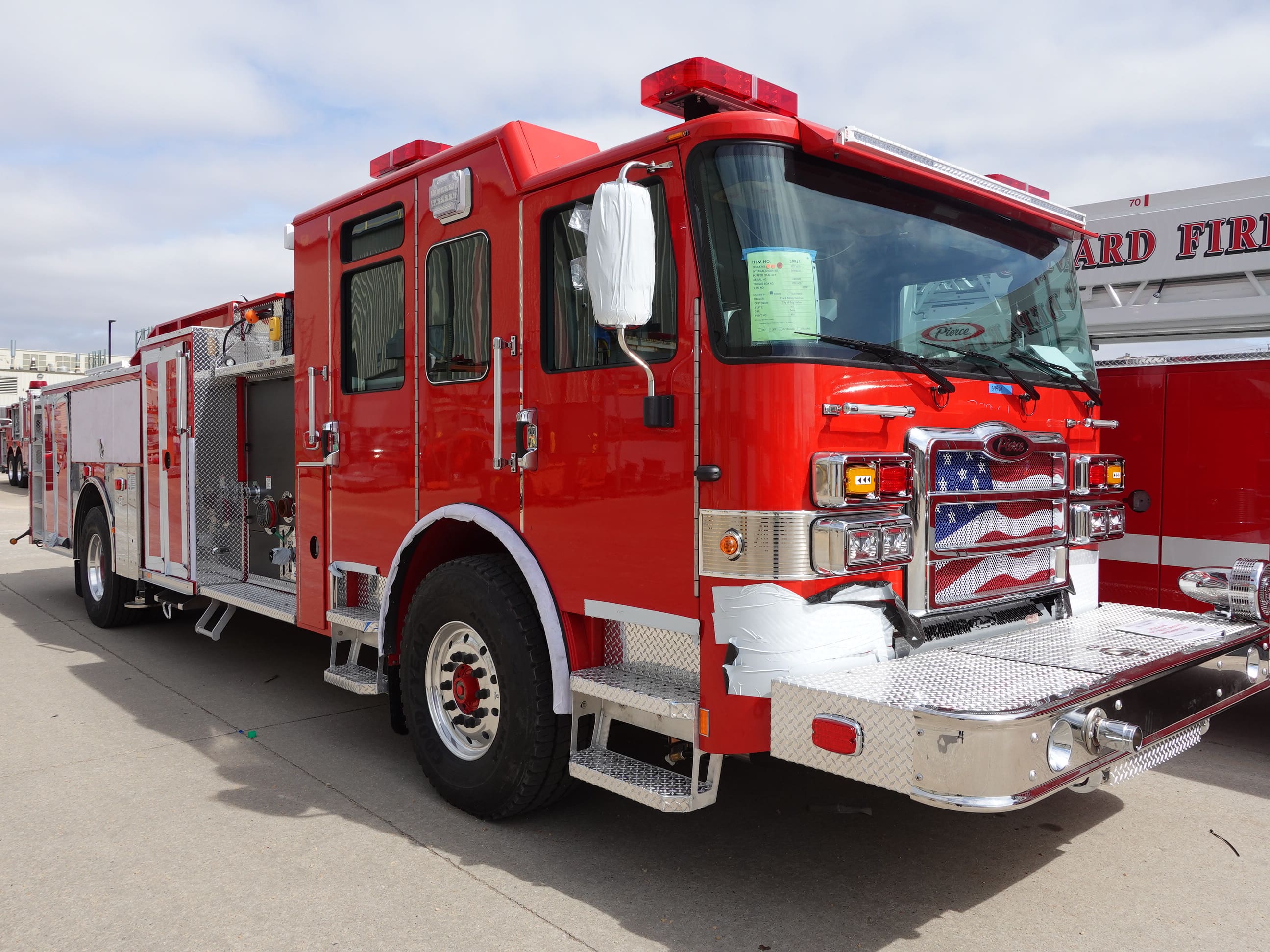

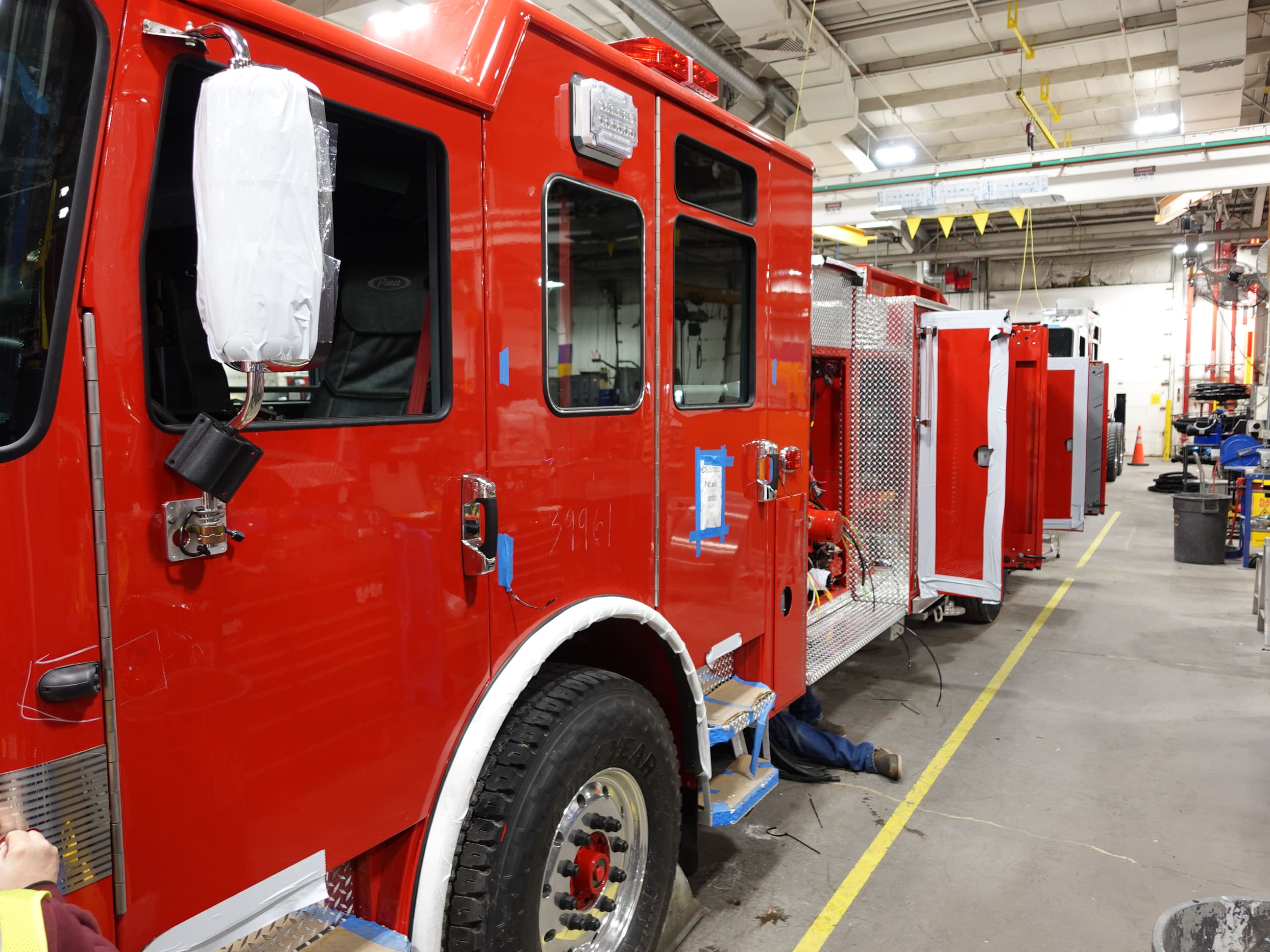

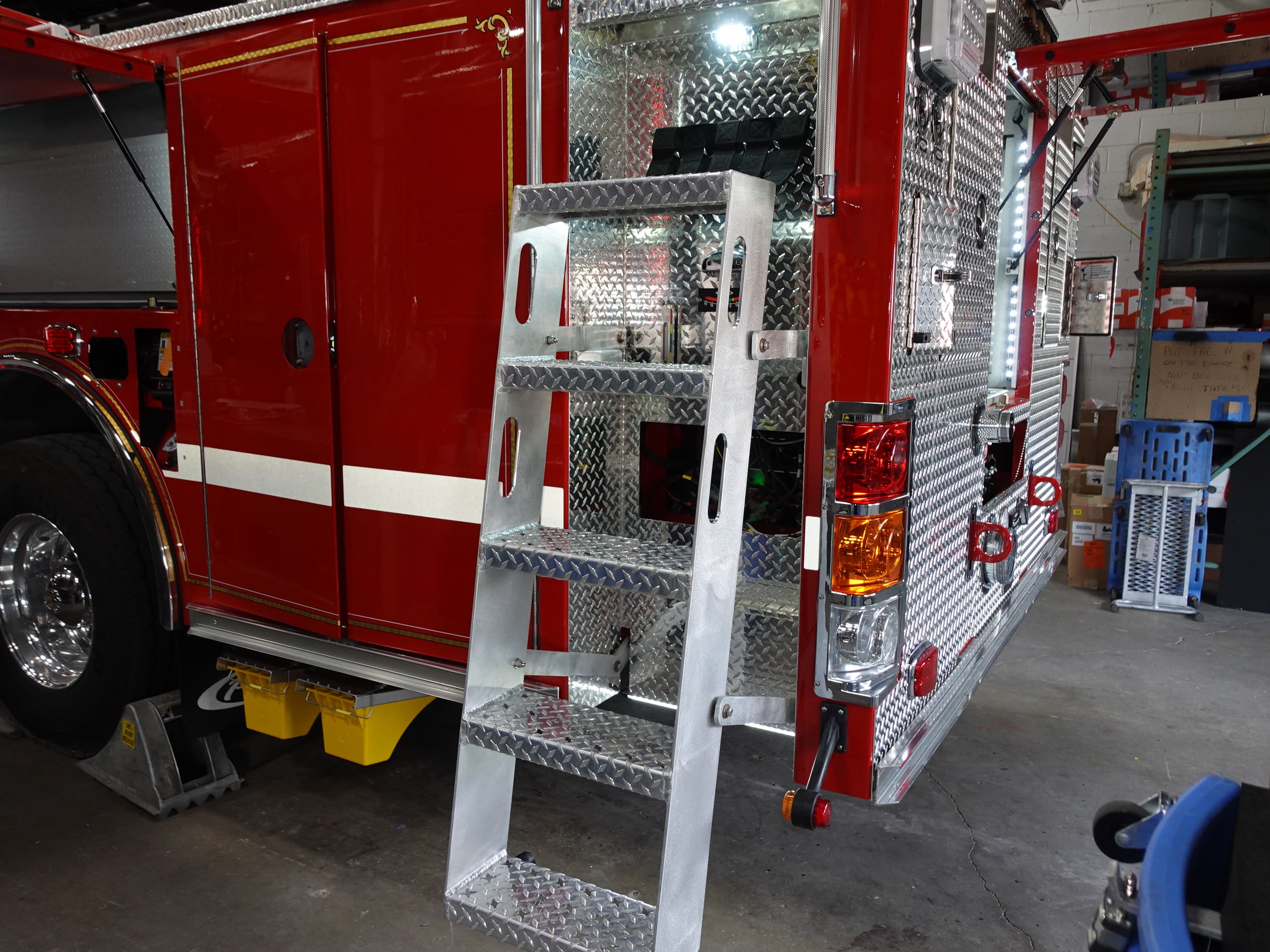

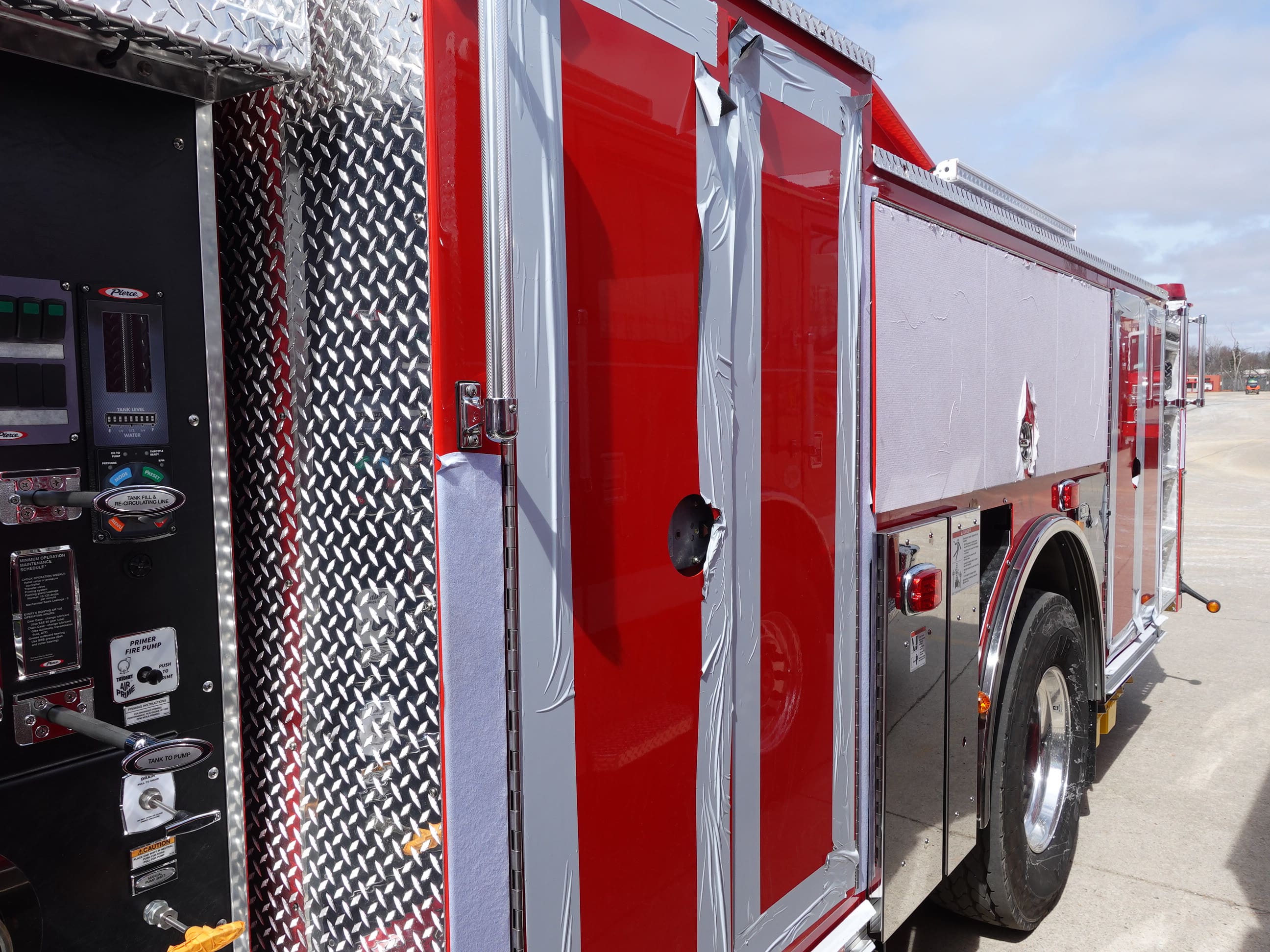

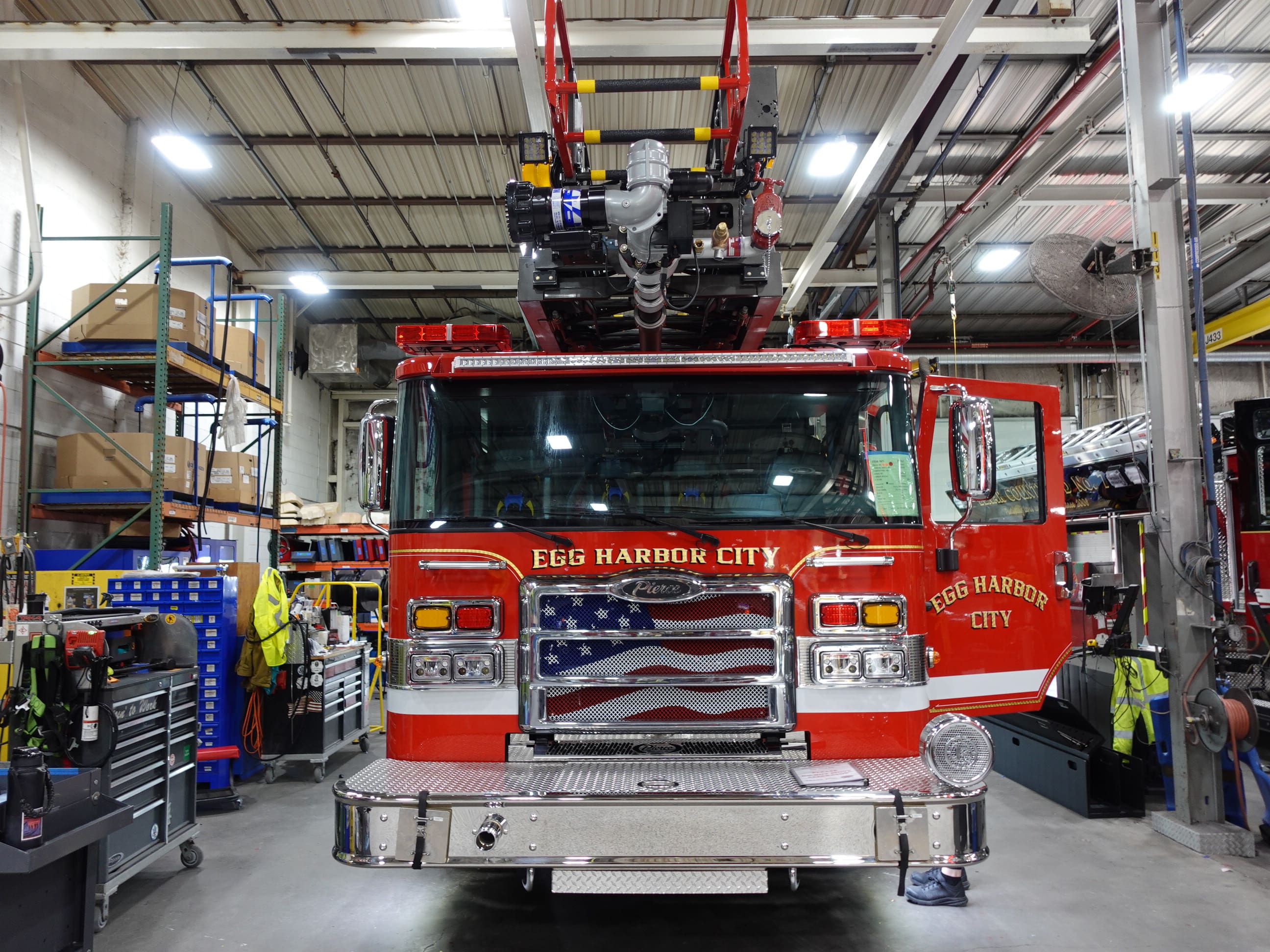

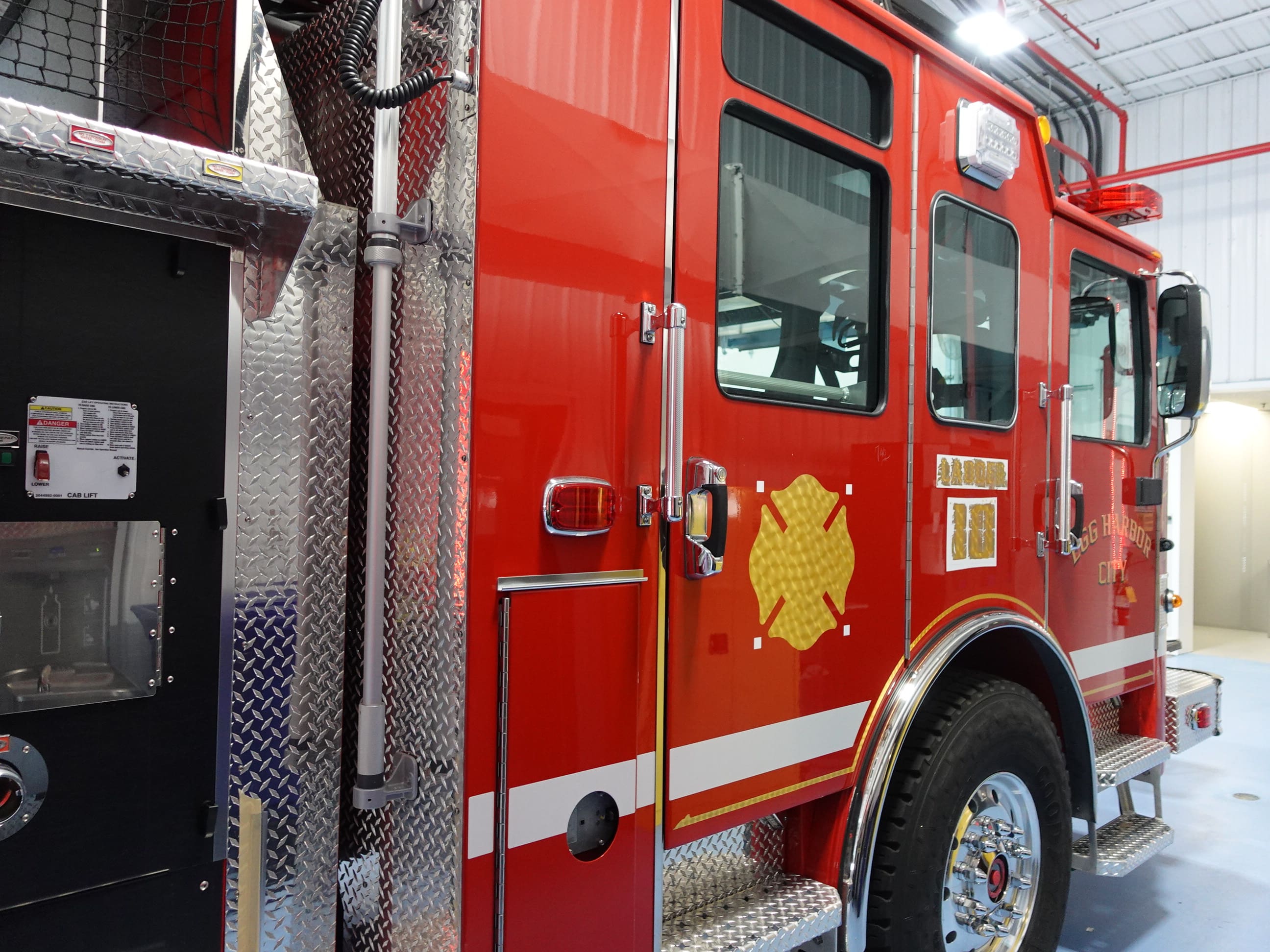

05-01-26

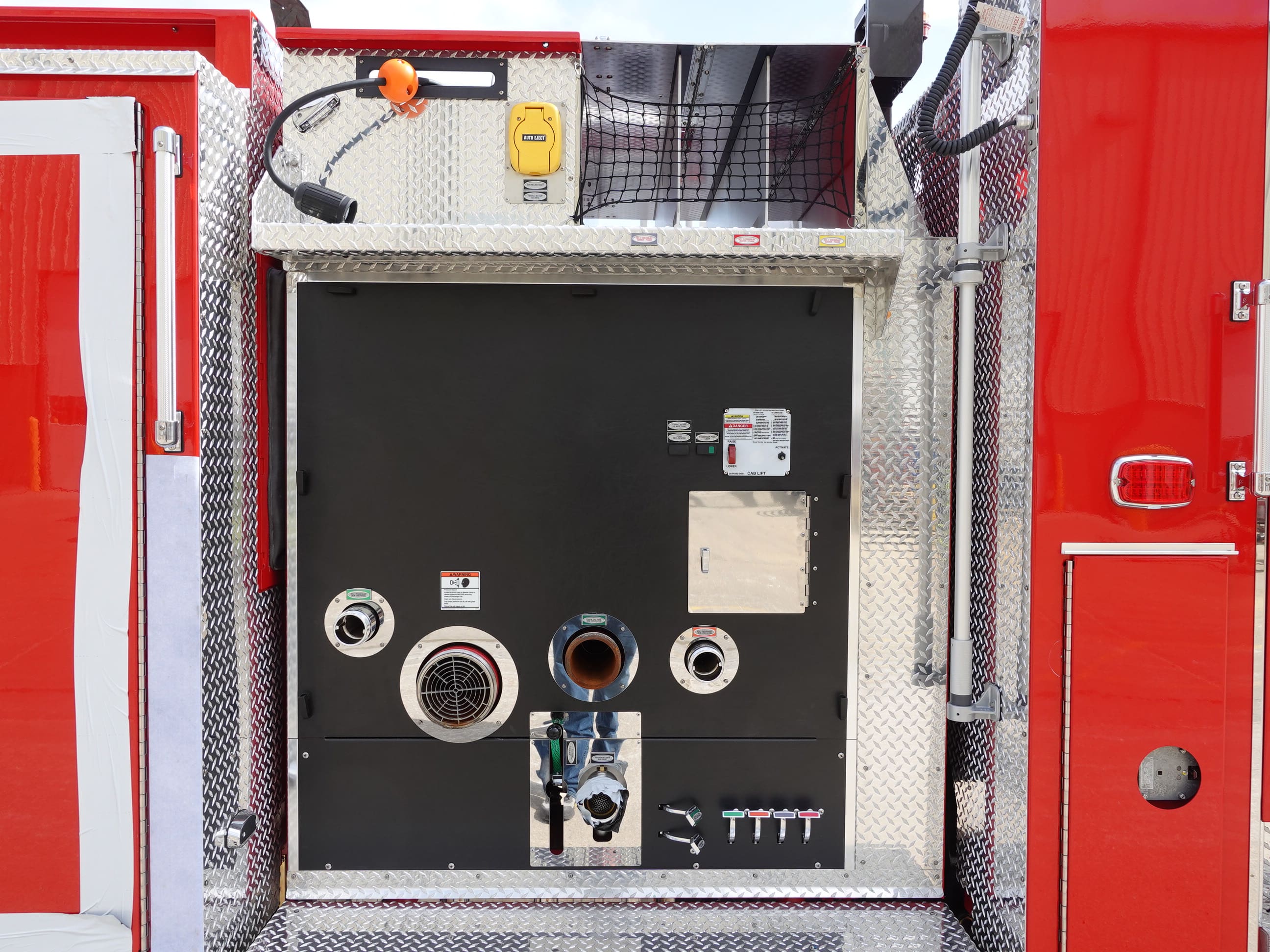

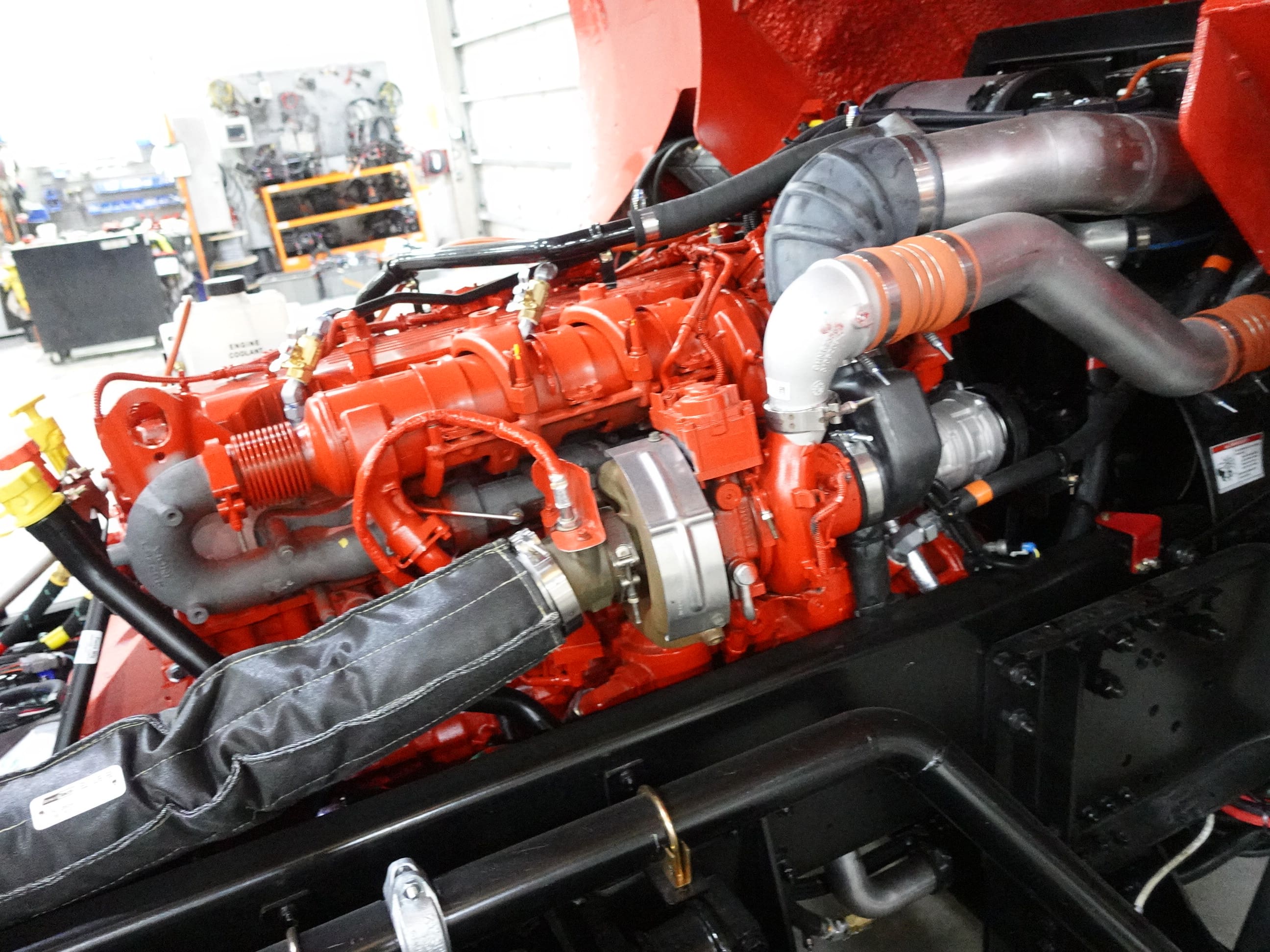

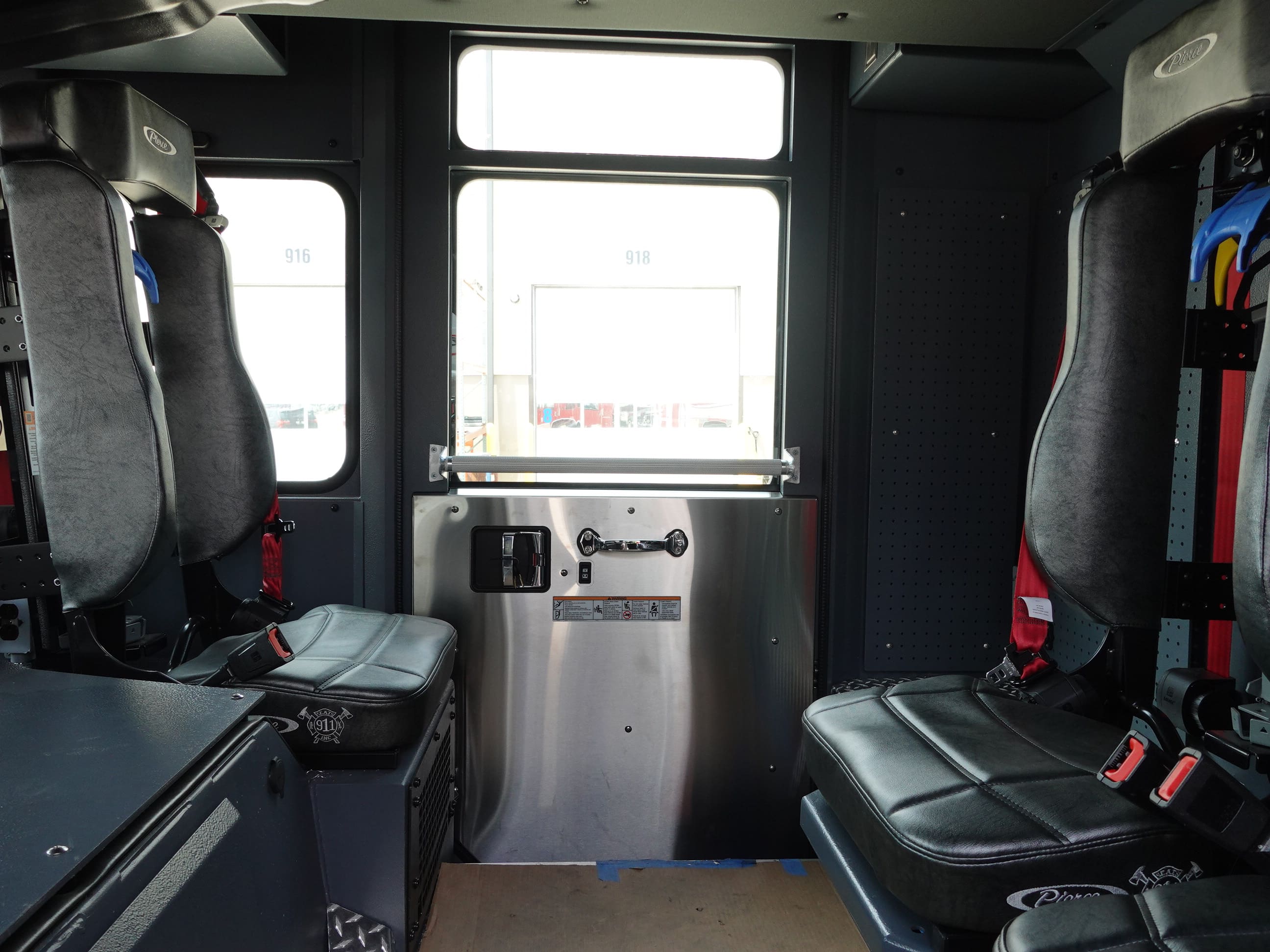

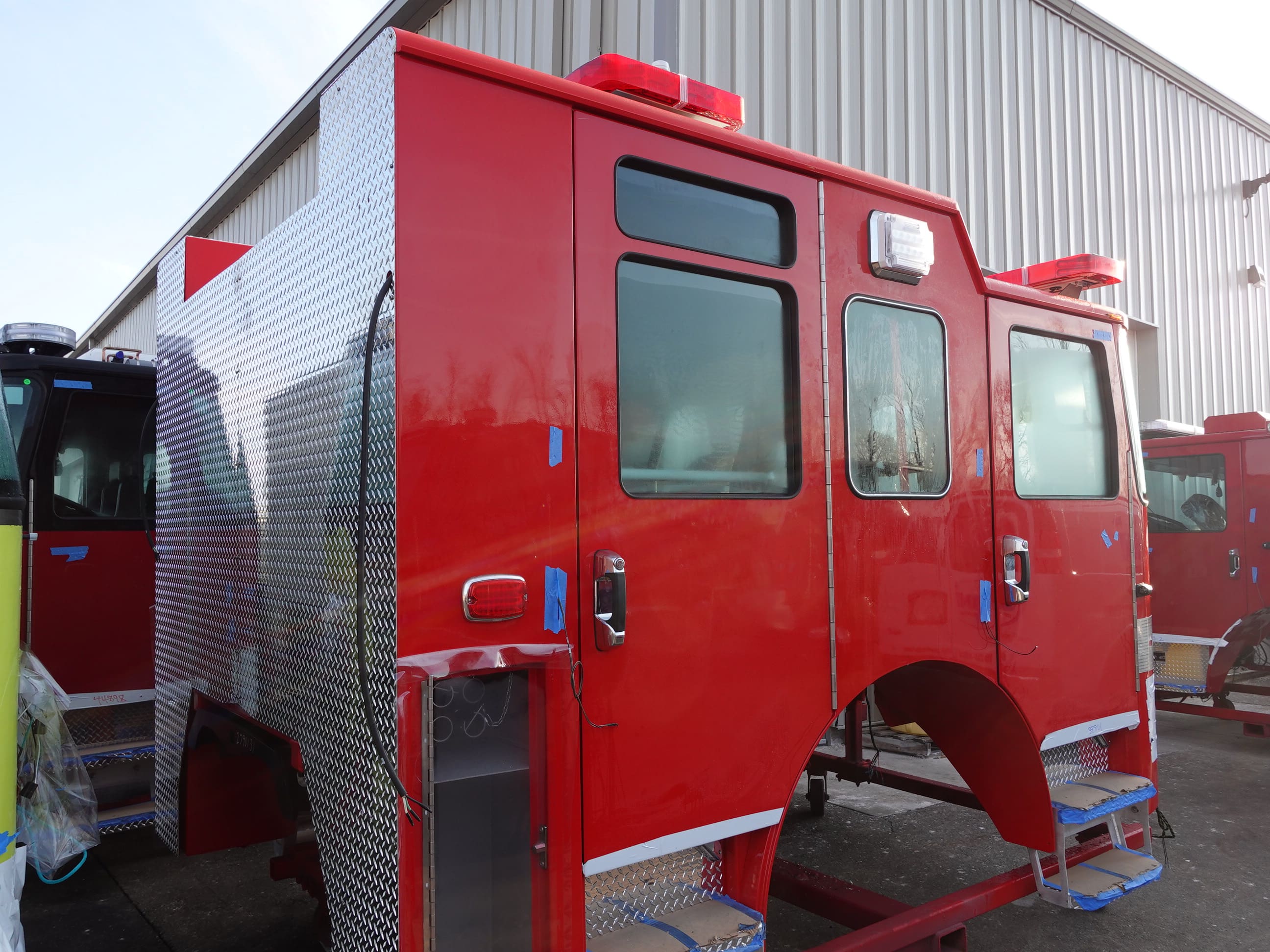

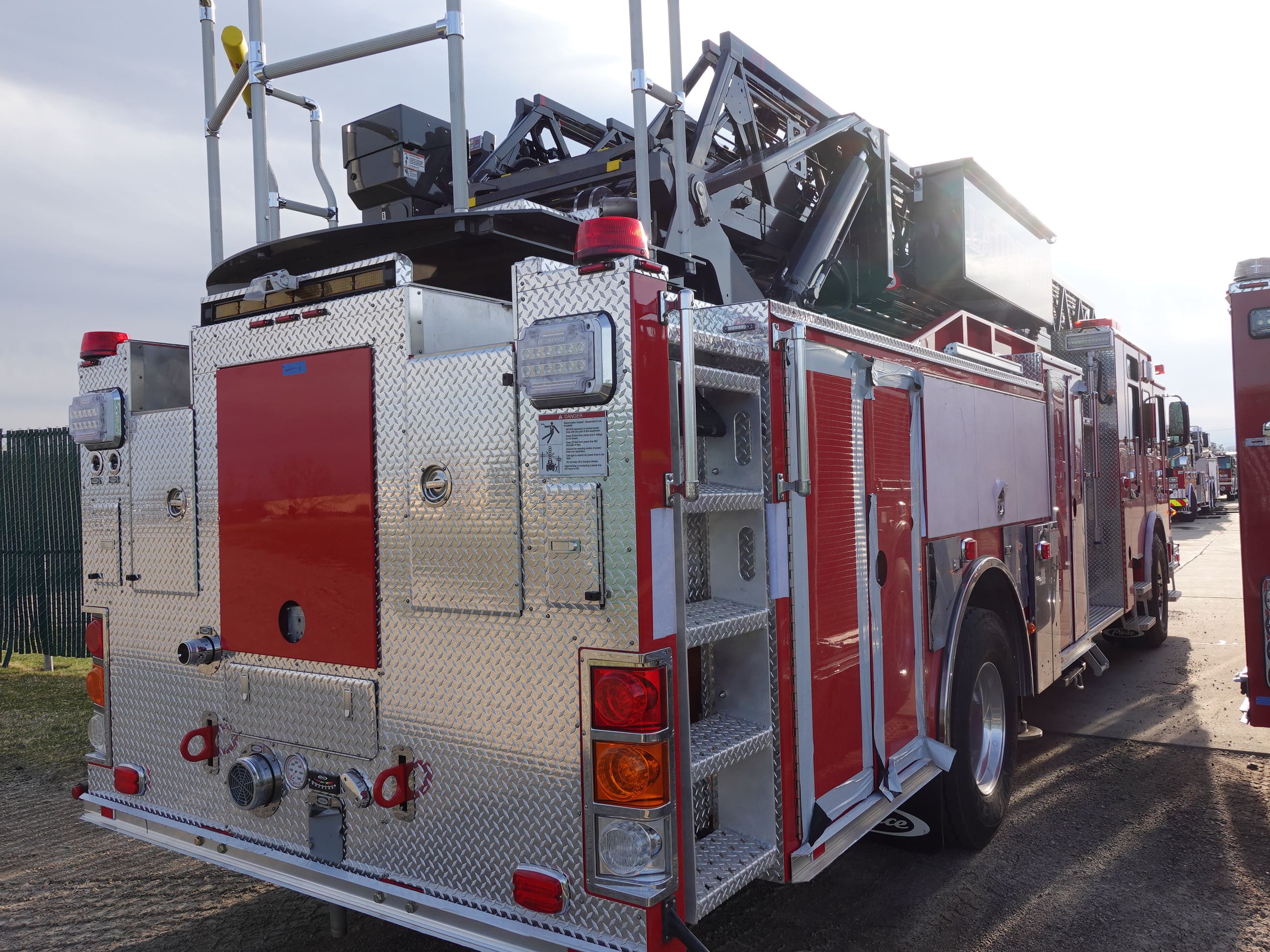

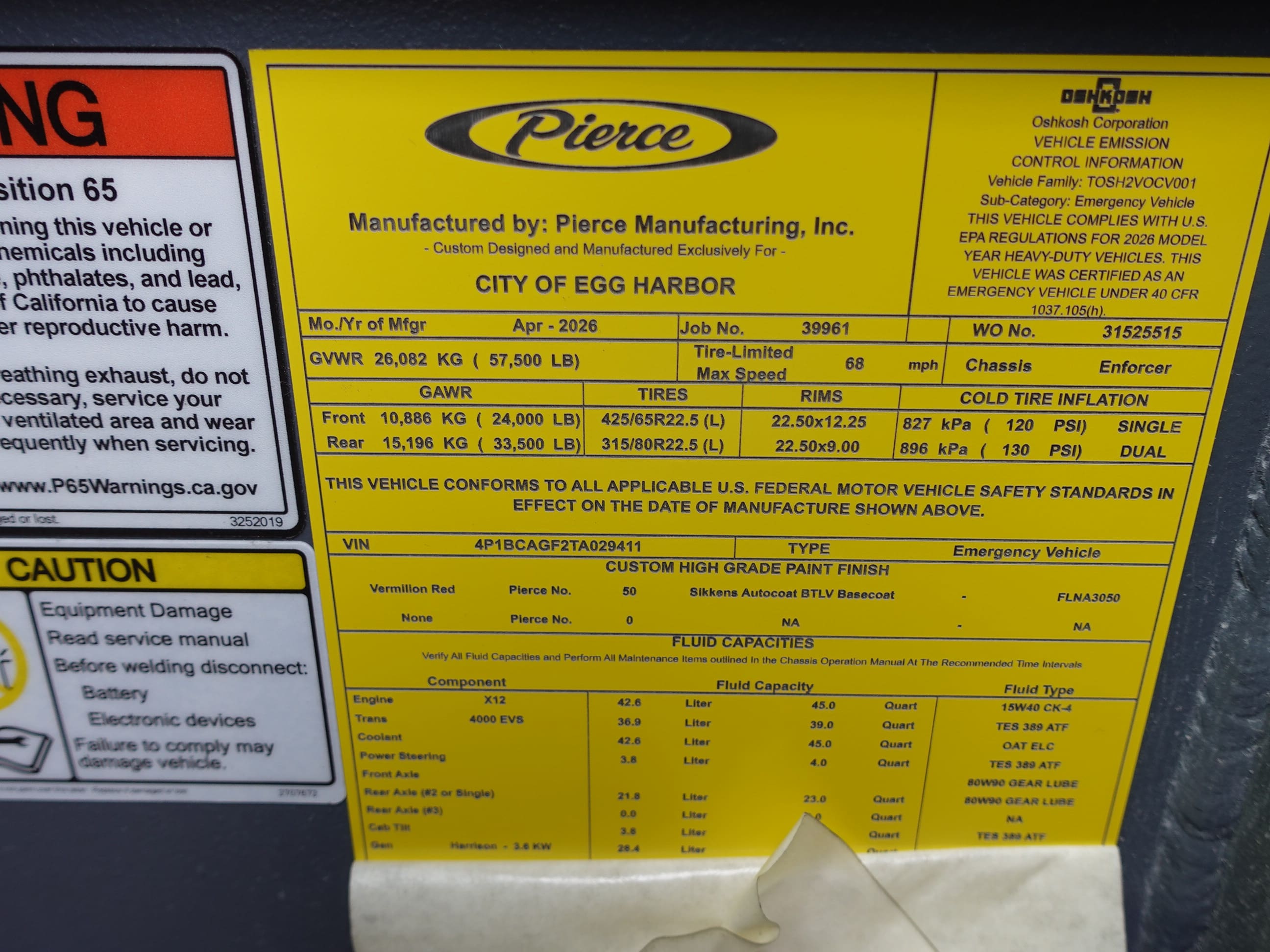

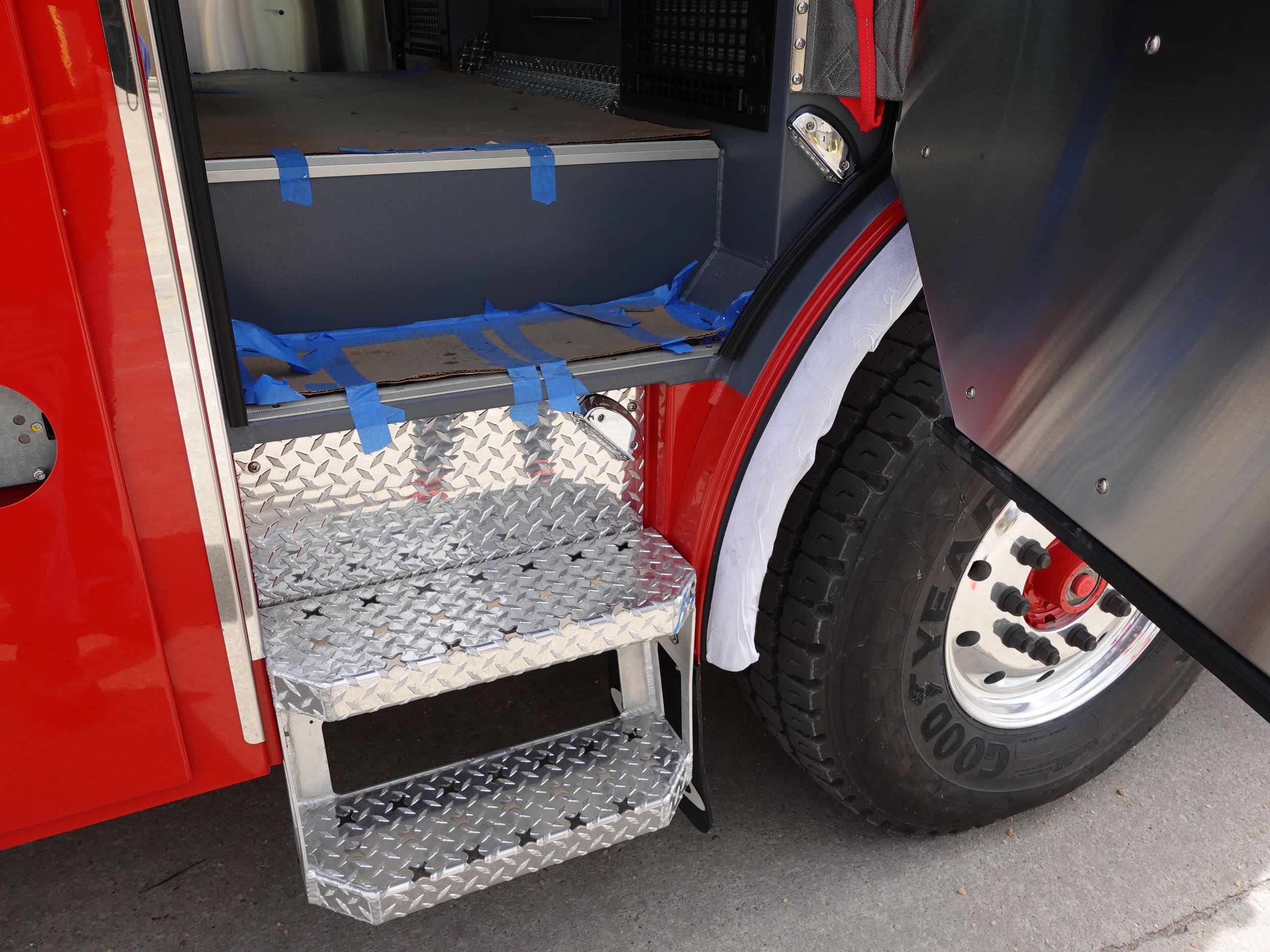

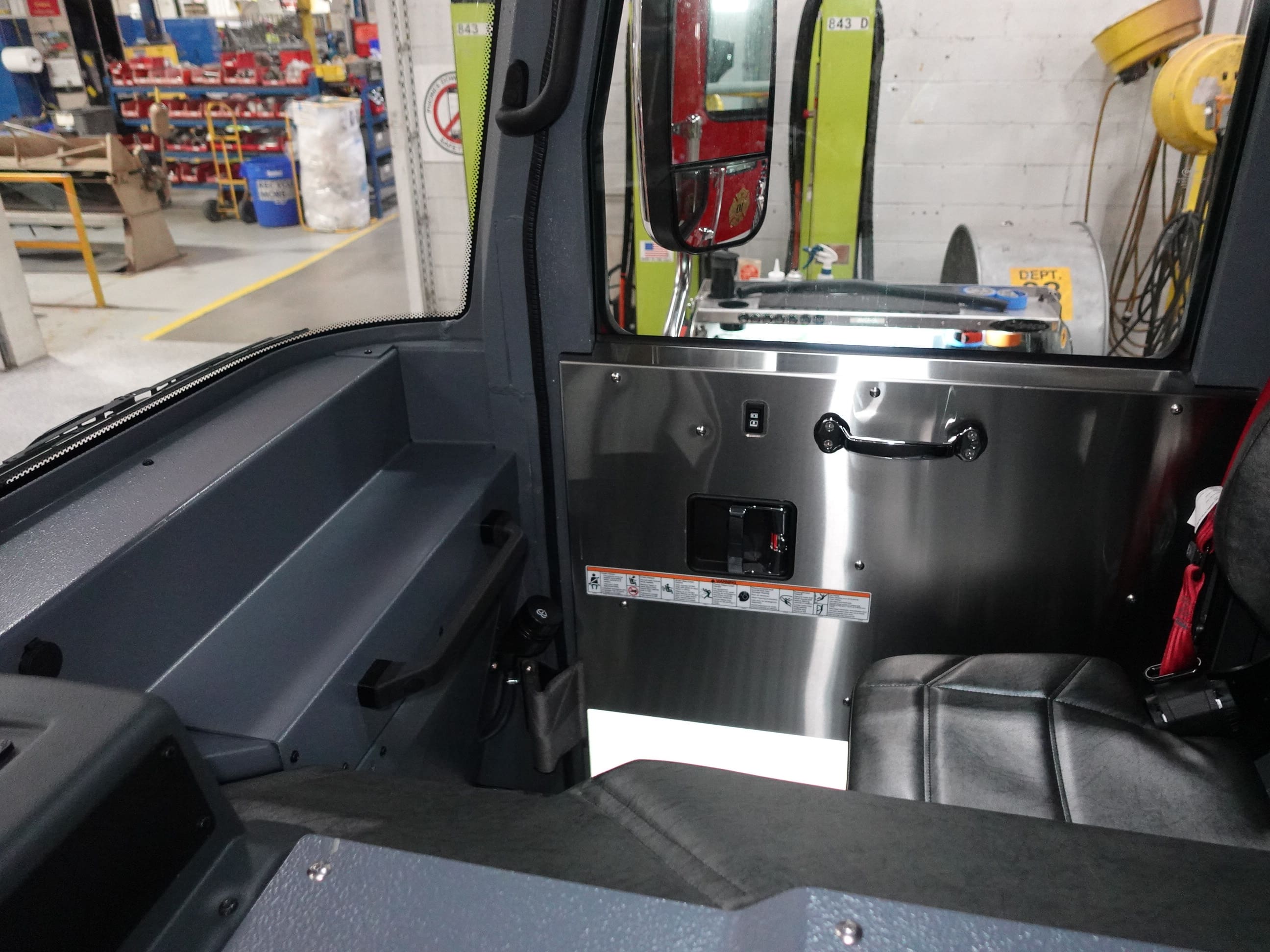

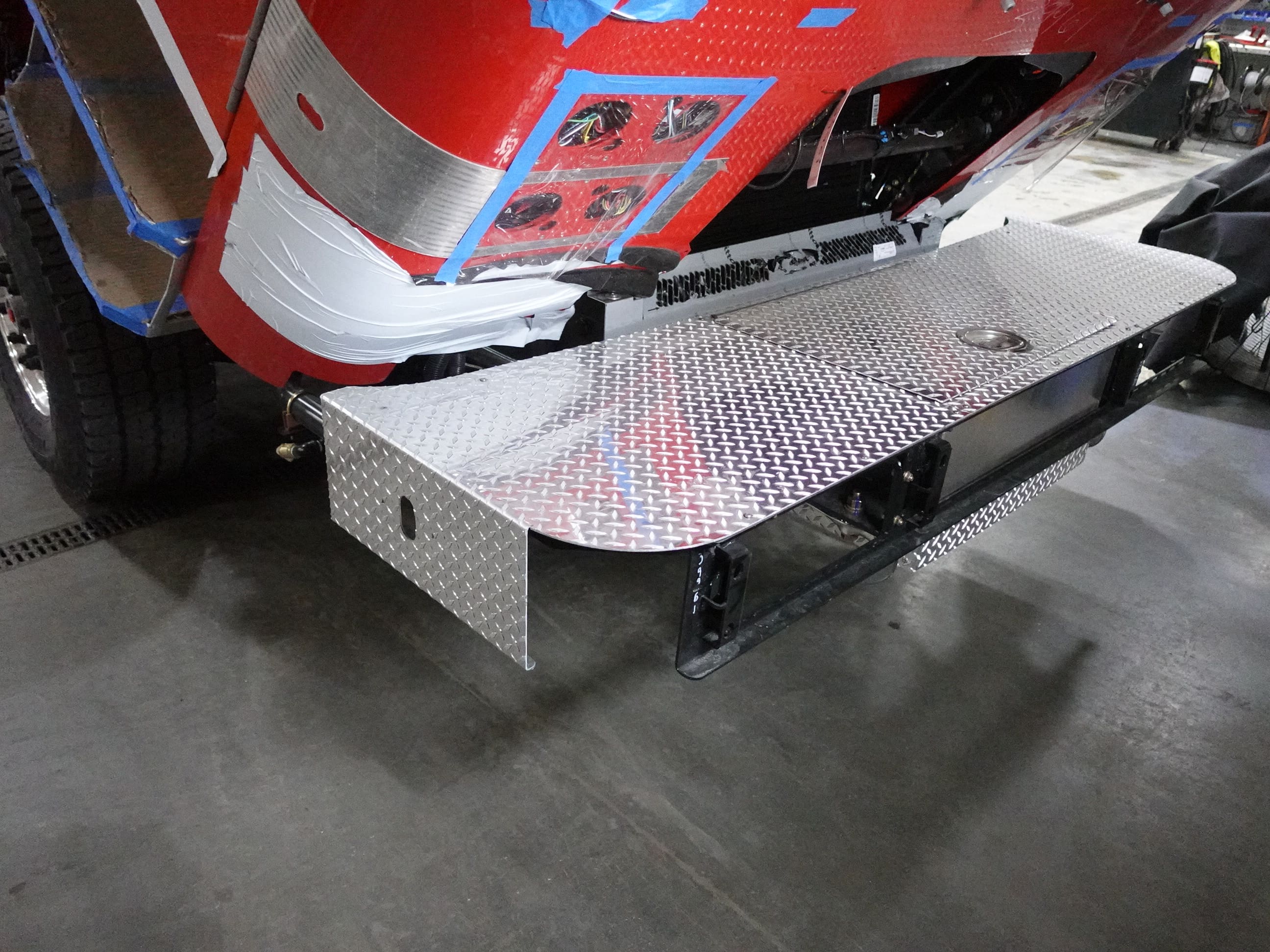

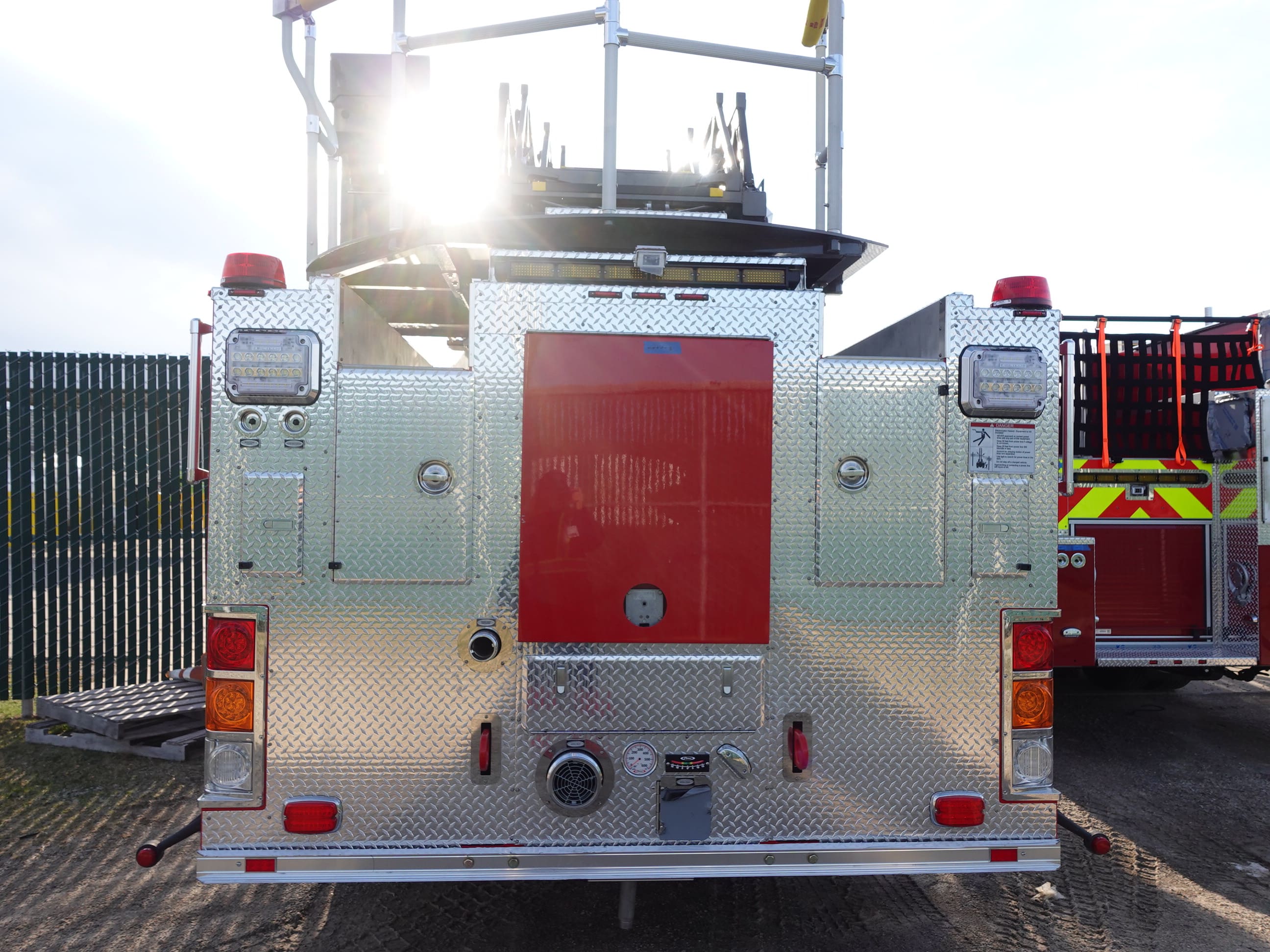

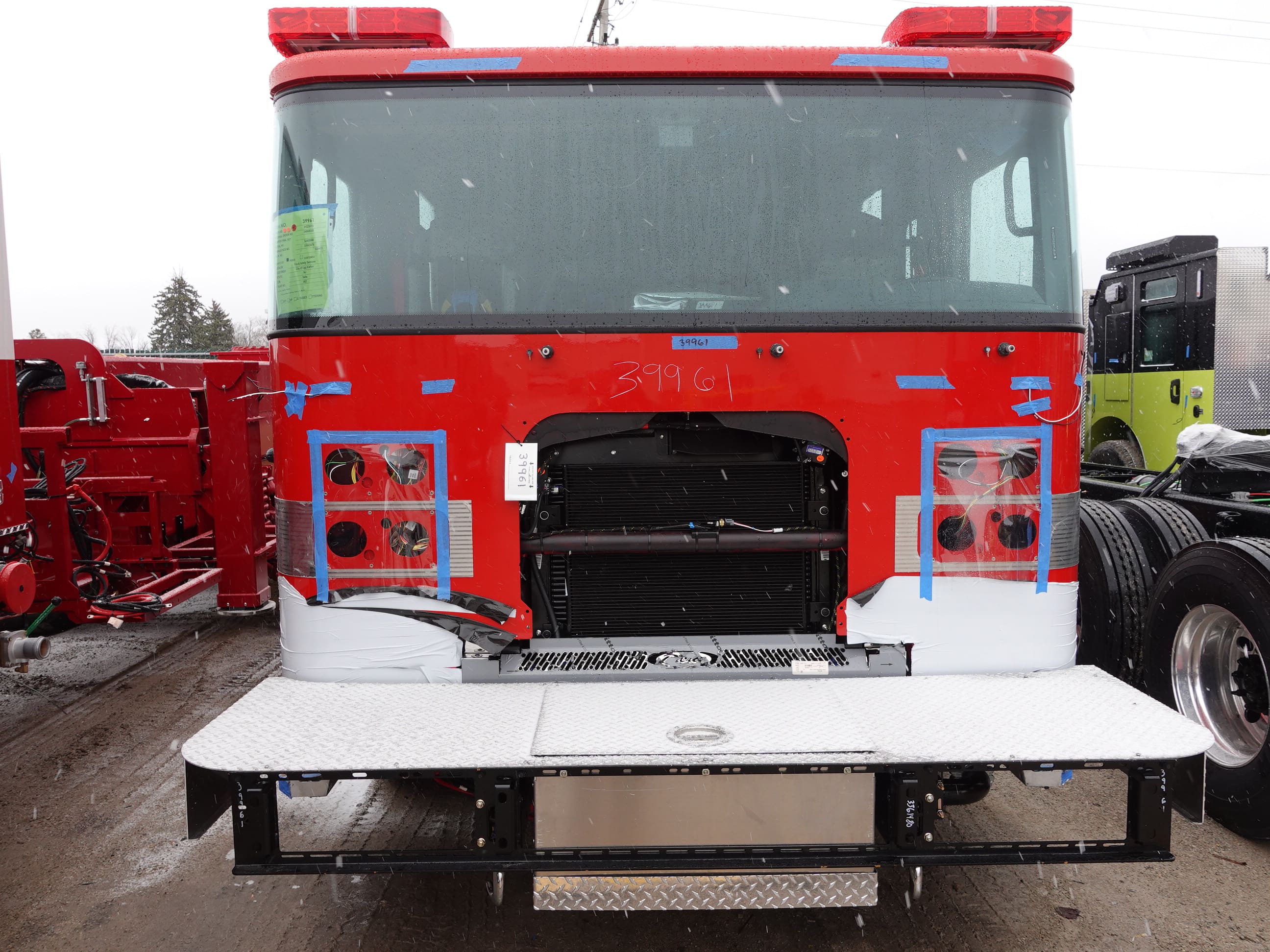

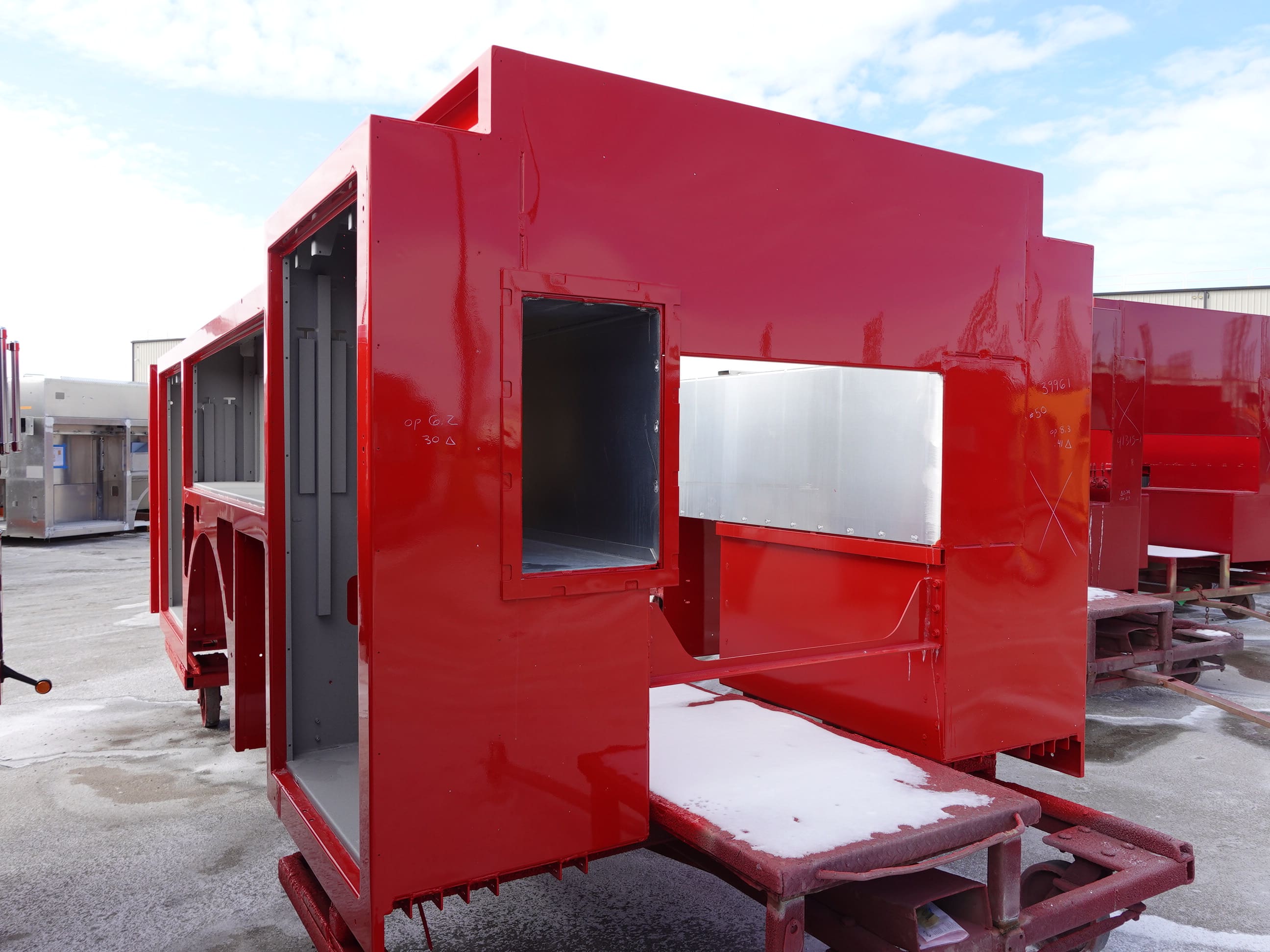

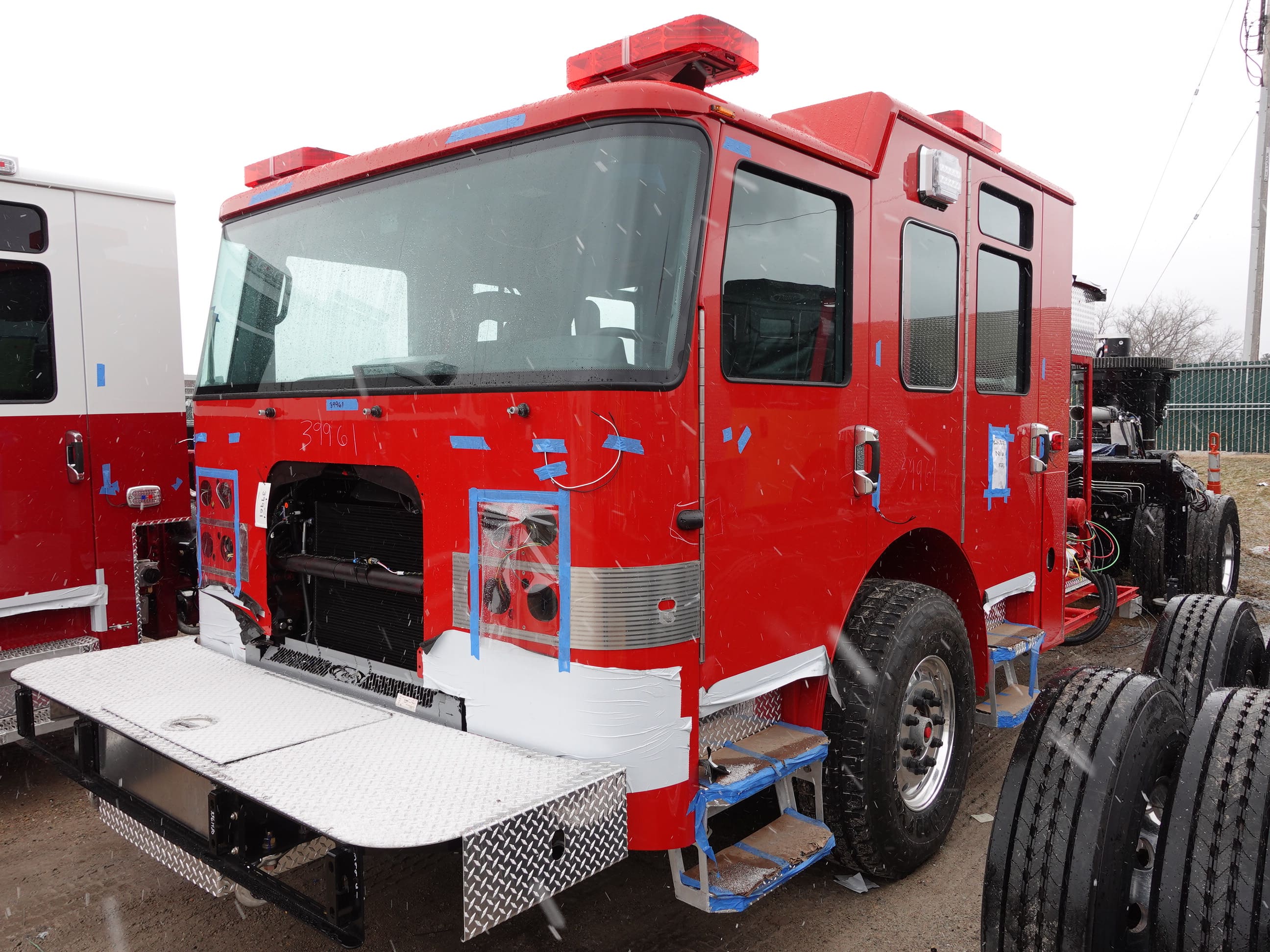

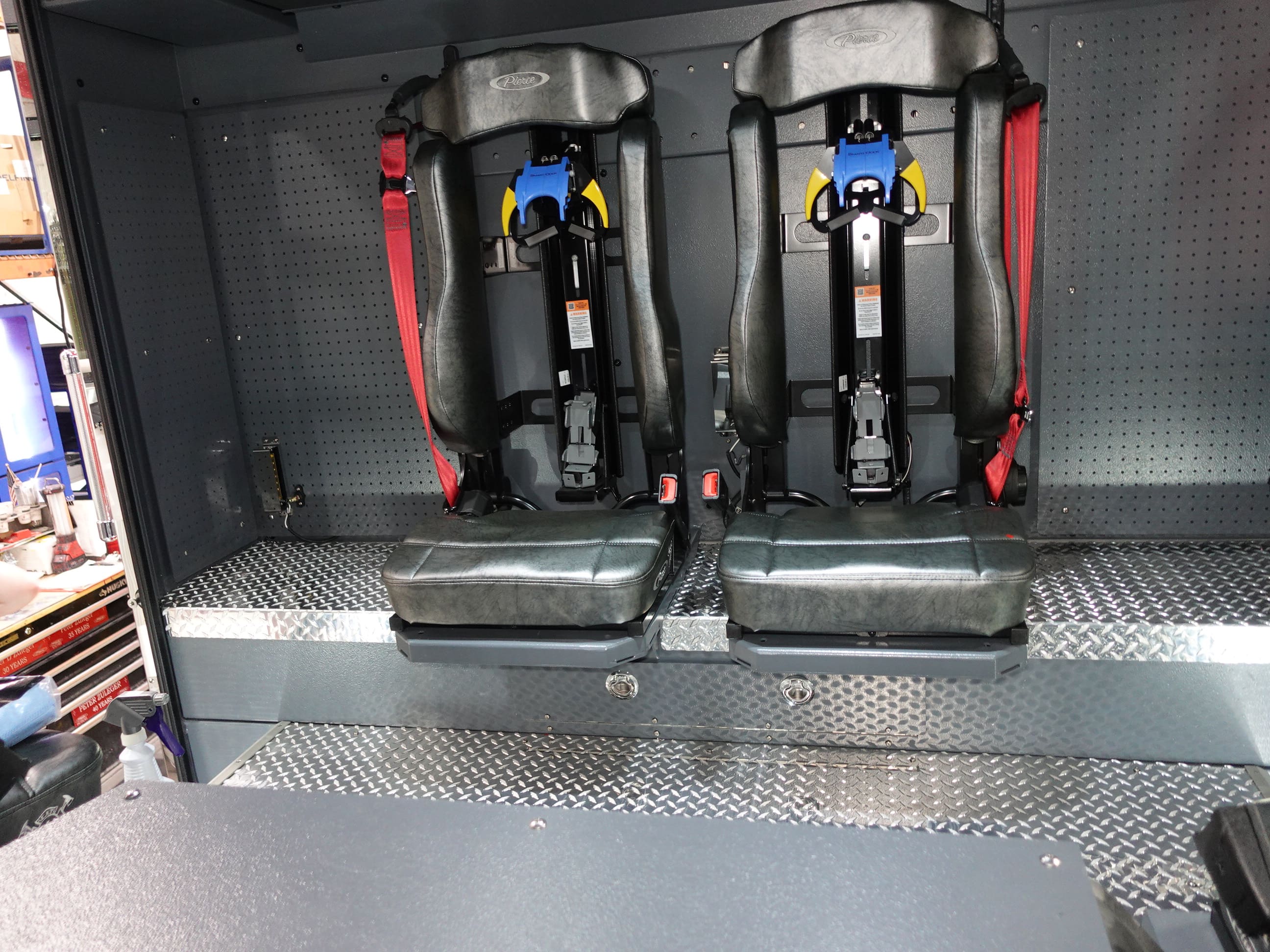

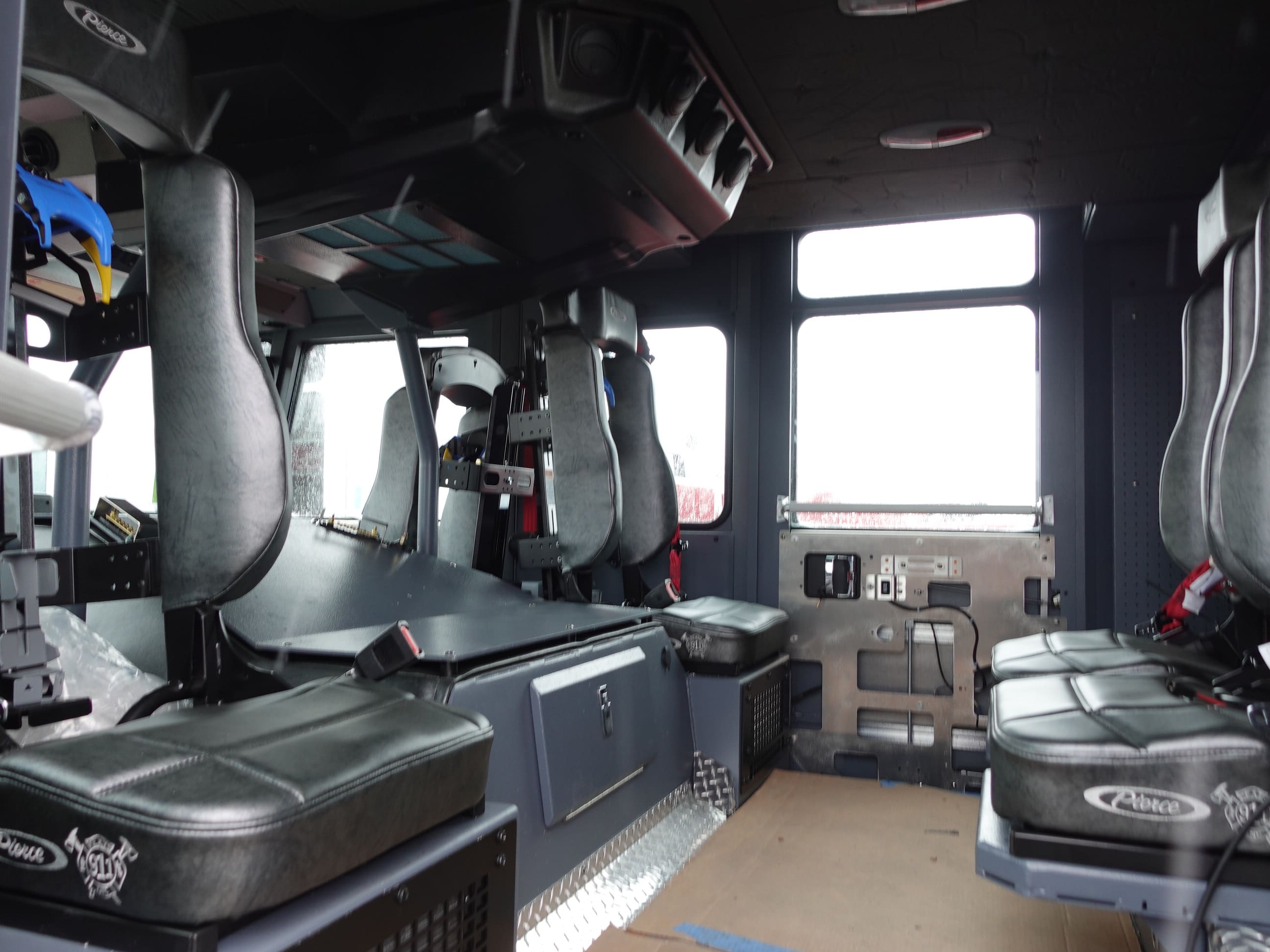

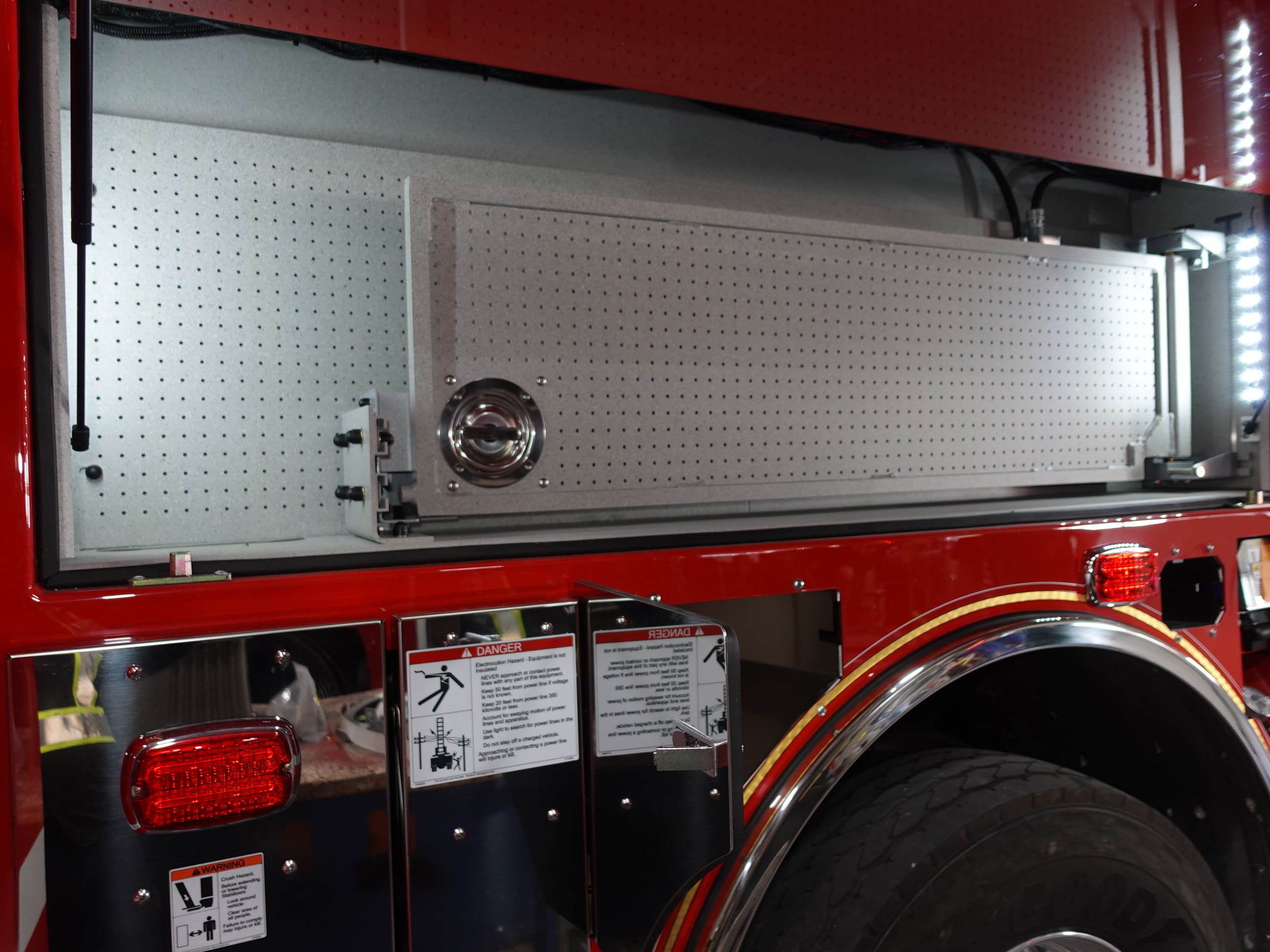

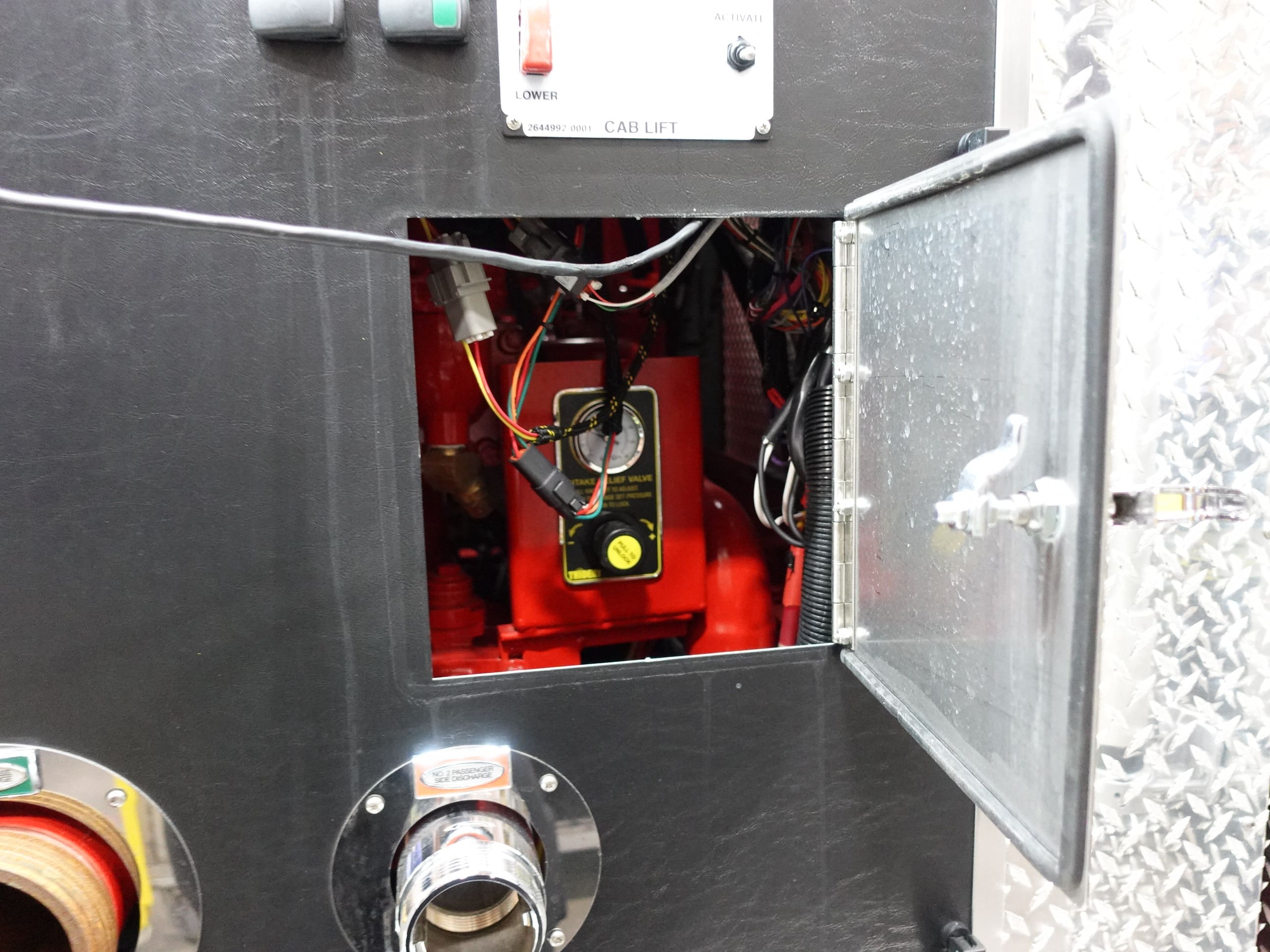

In this report, the apparatus completed graphics

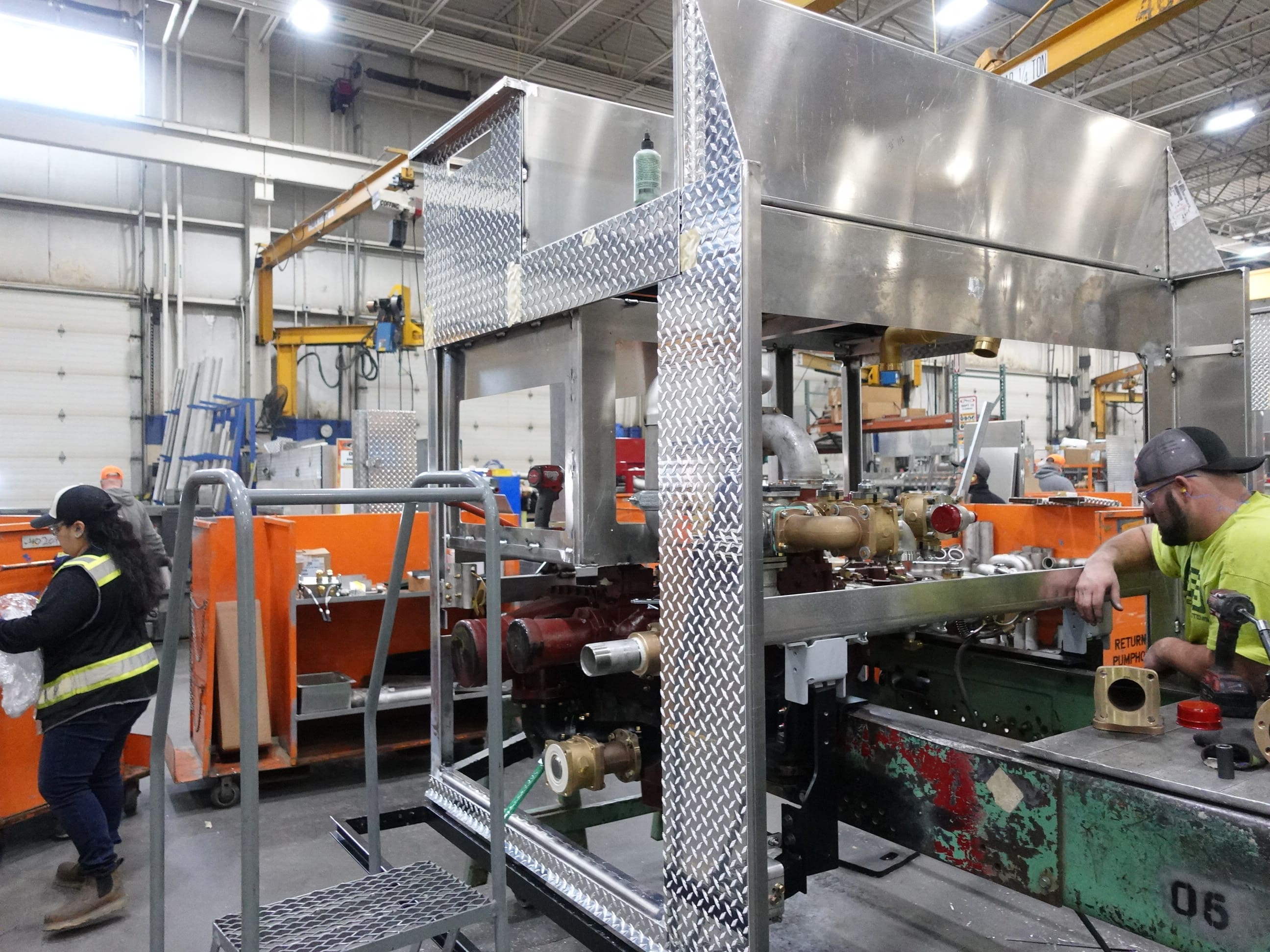

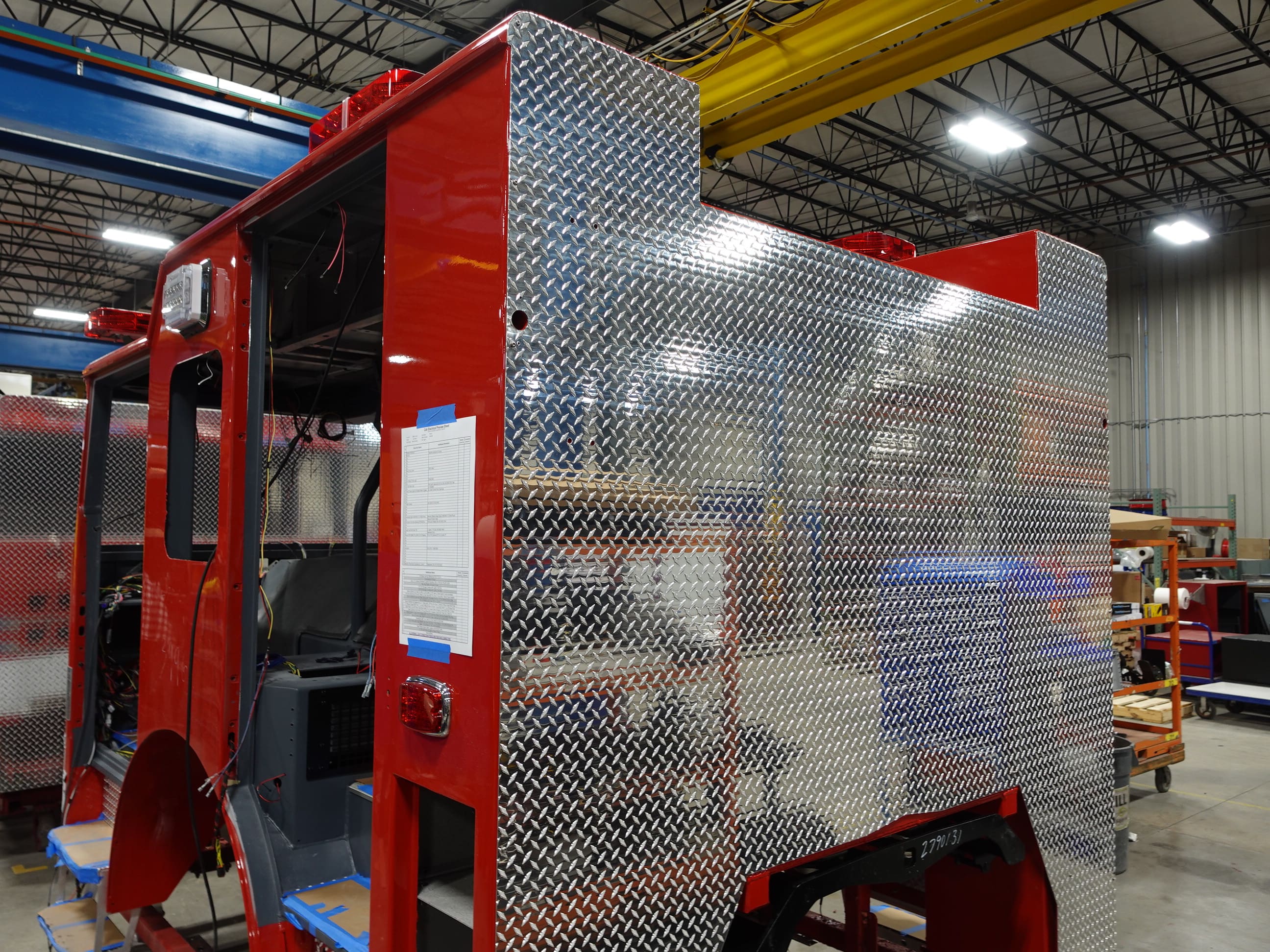

application then continued the quality process where

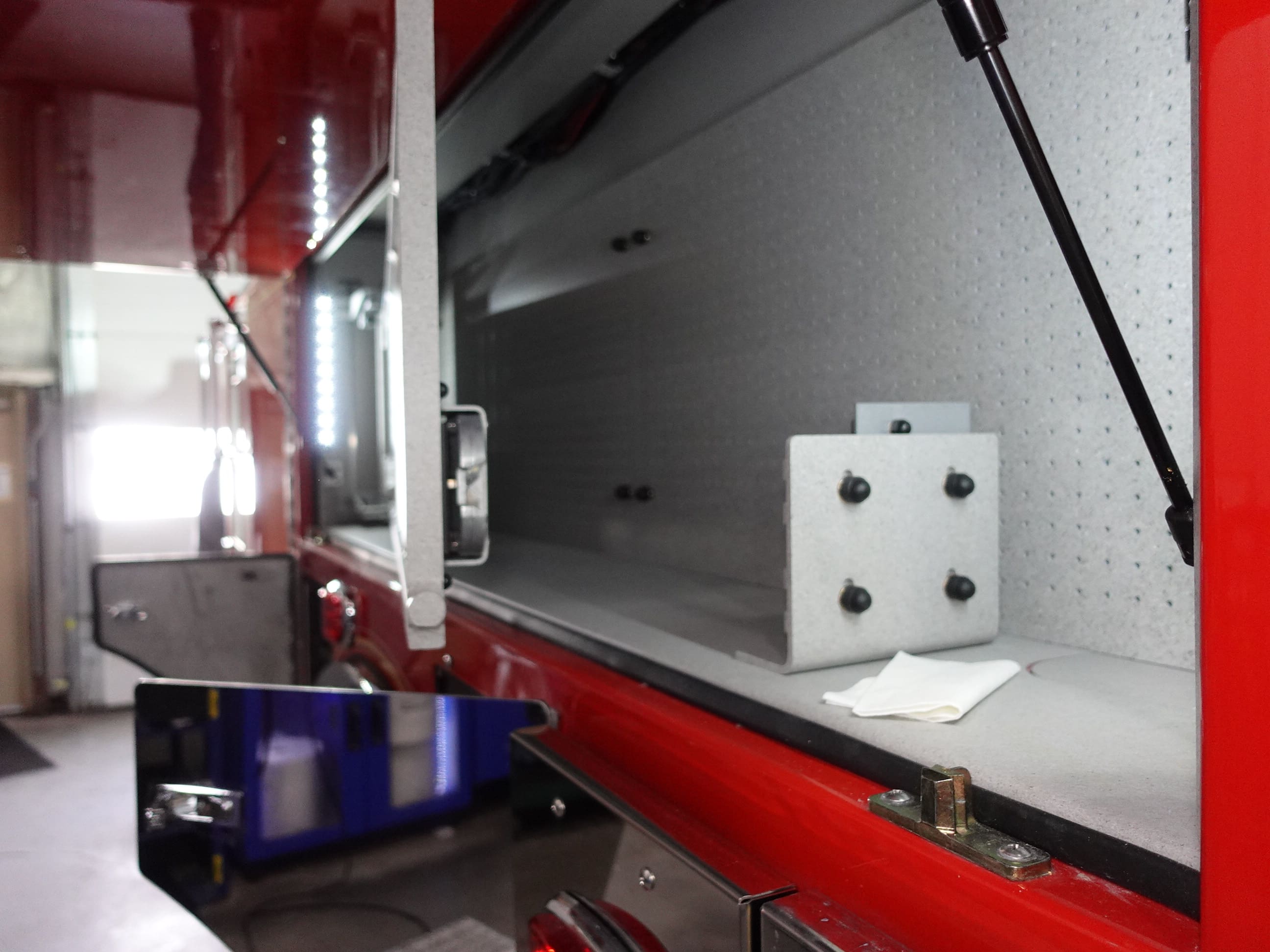

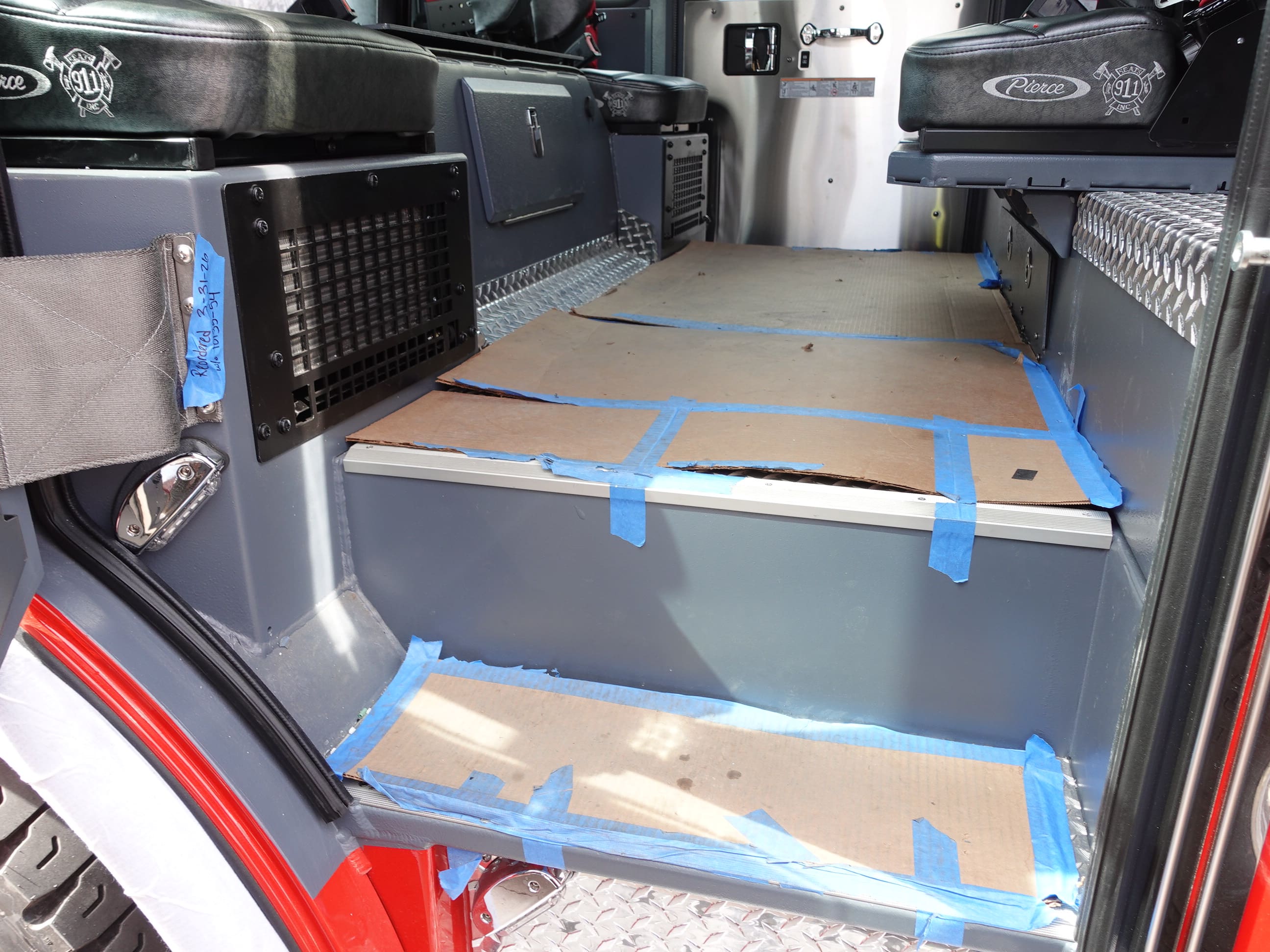

any remaining content will be applied. Once finished

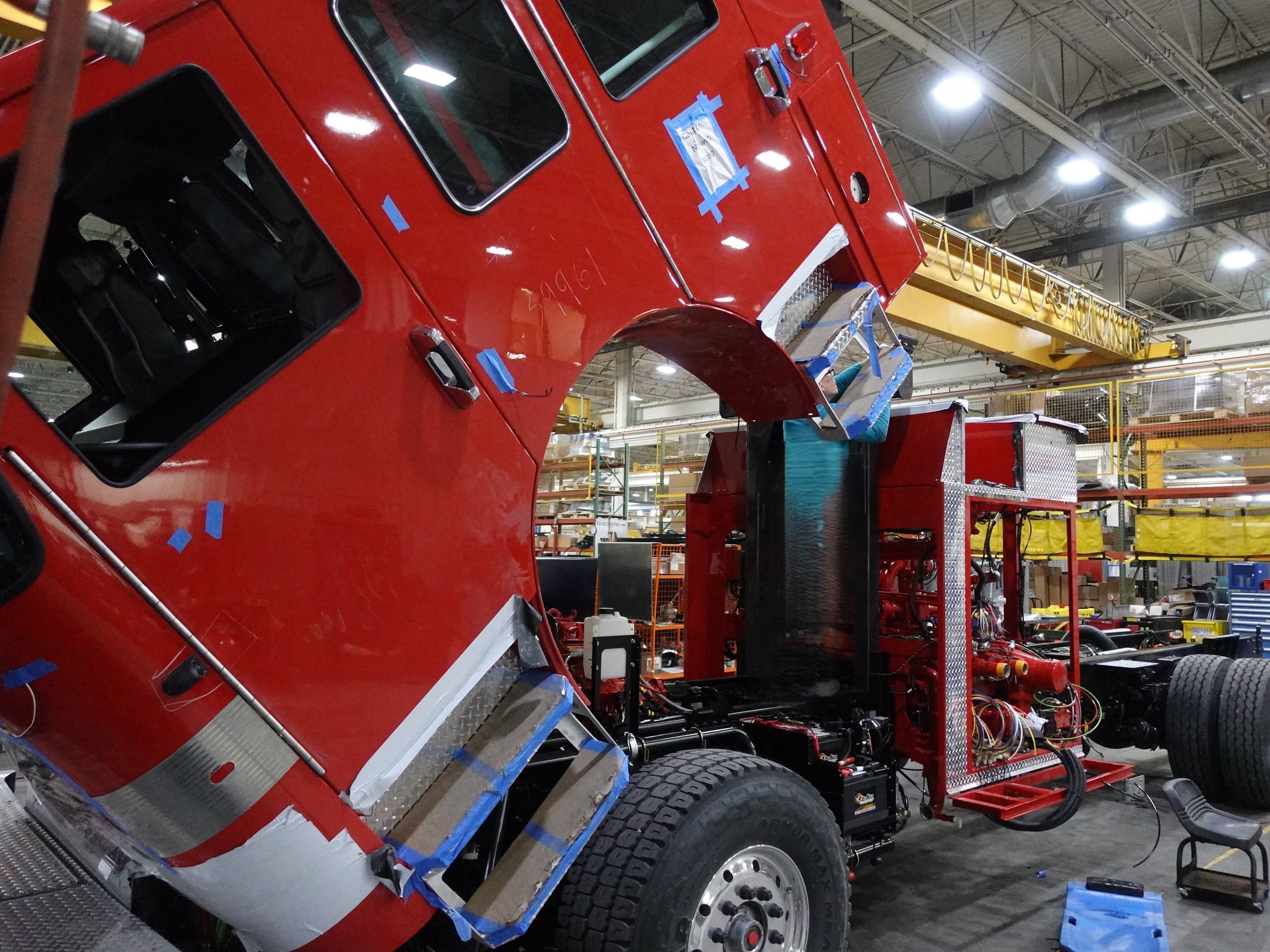

it will be made ready for the customer acceptance

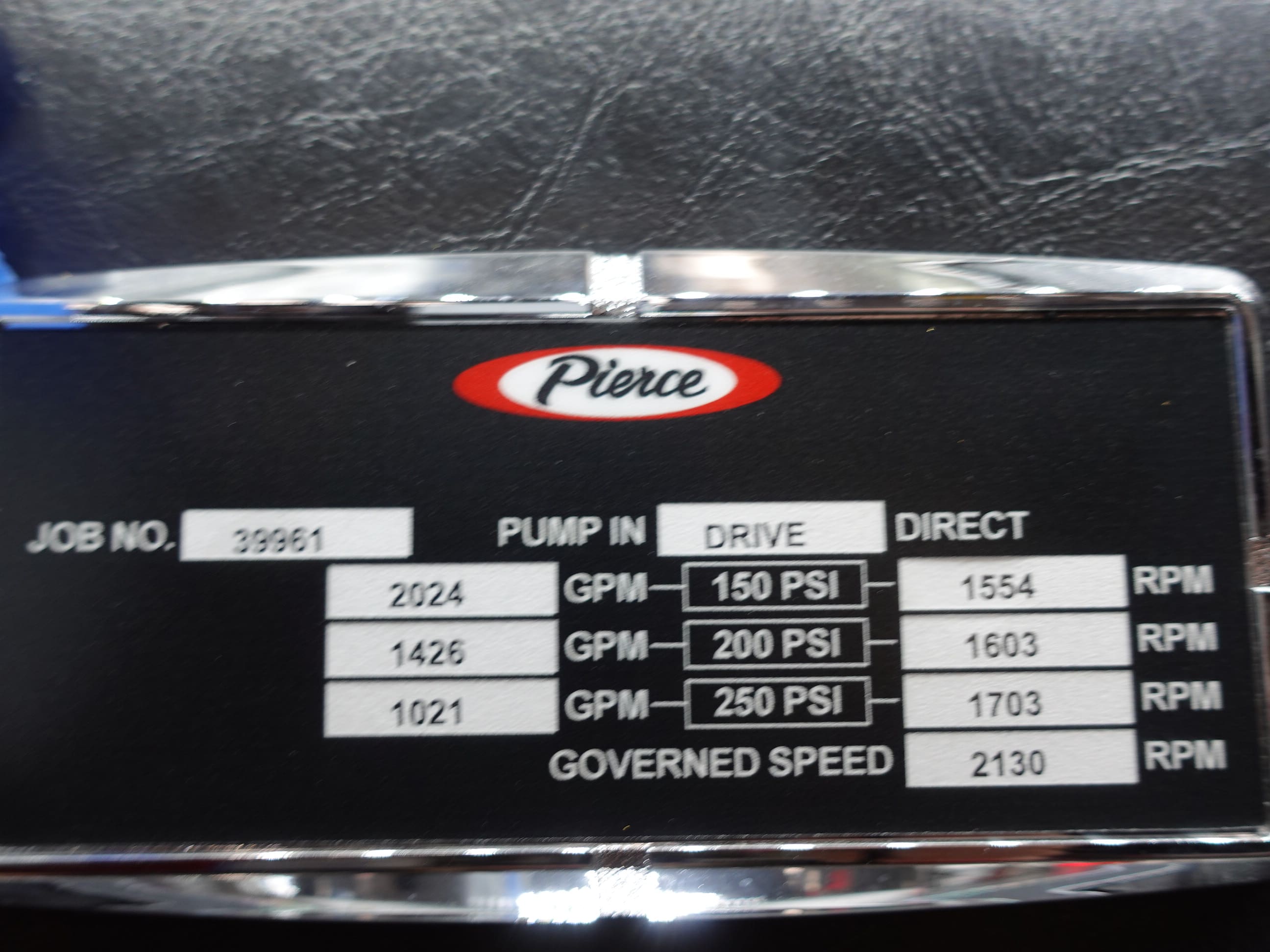

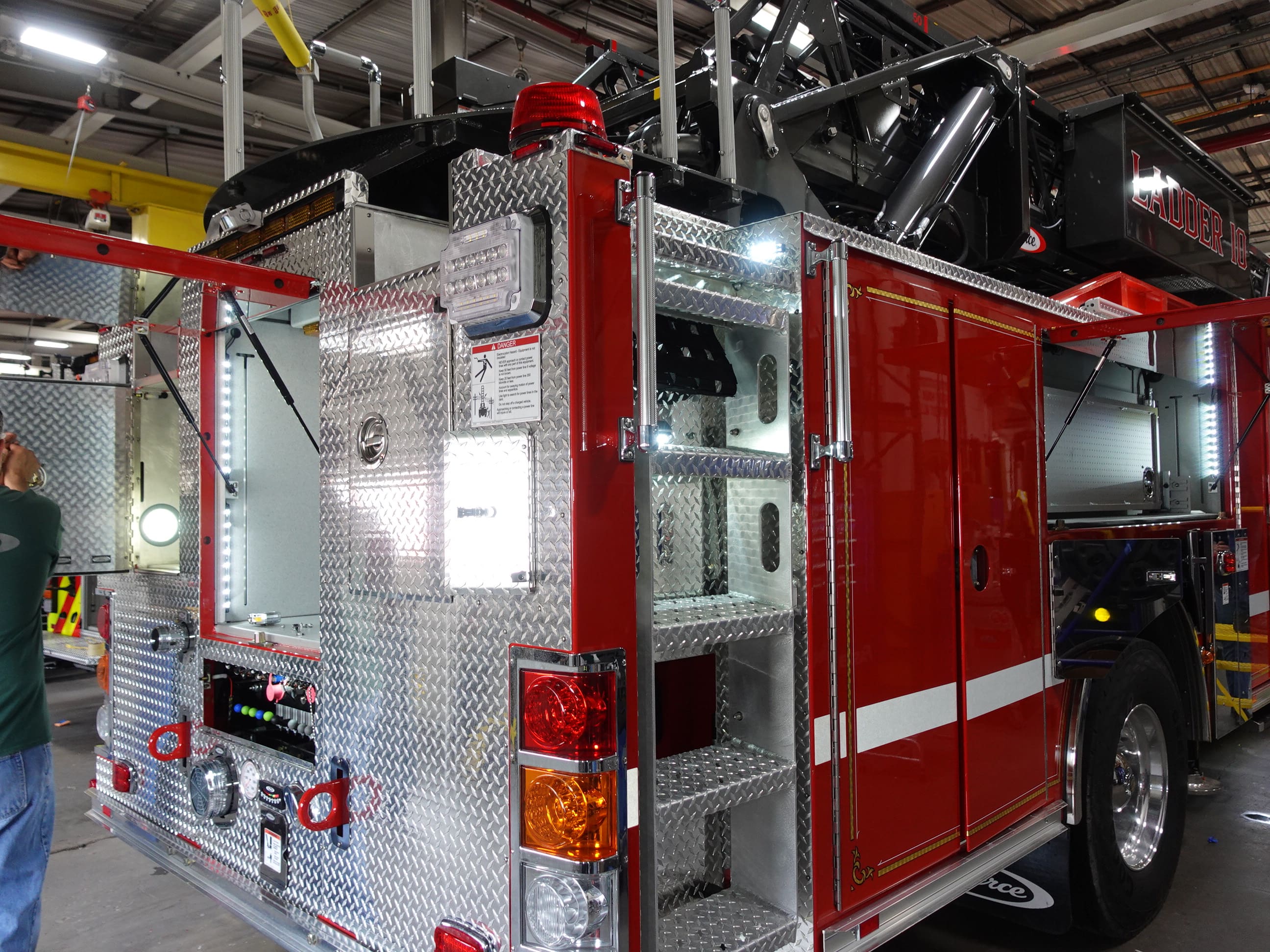

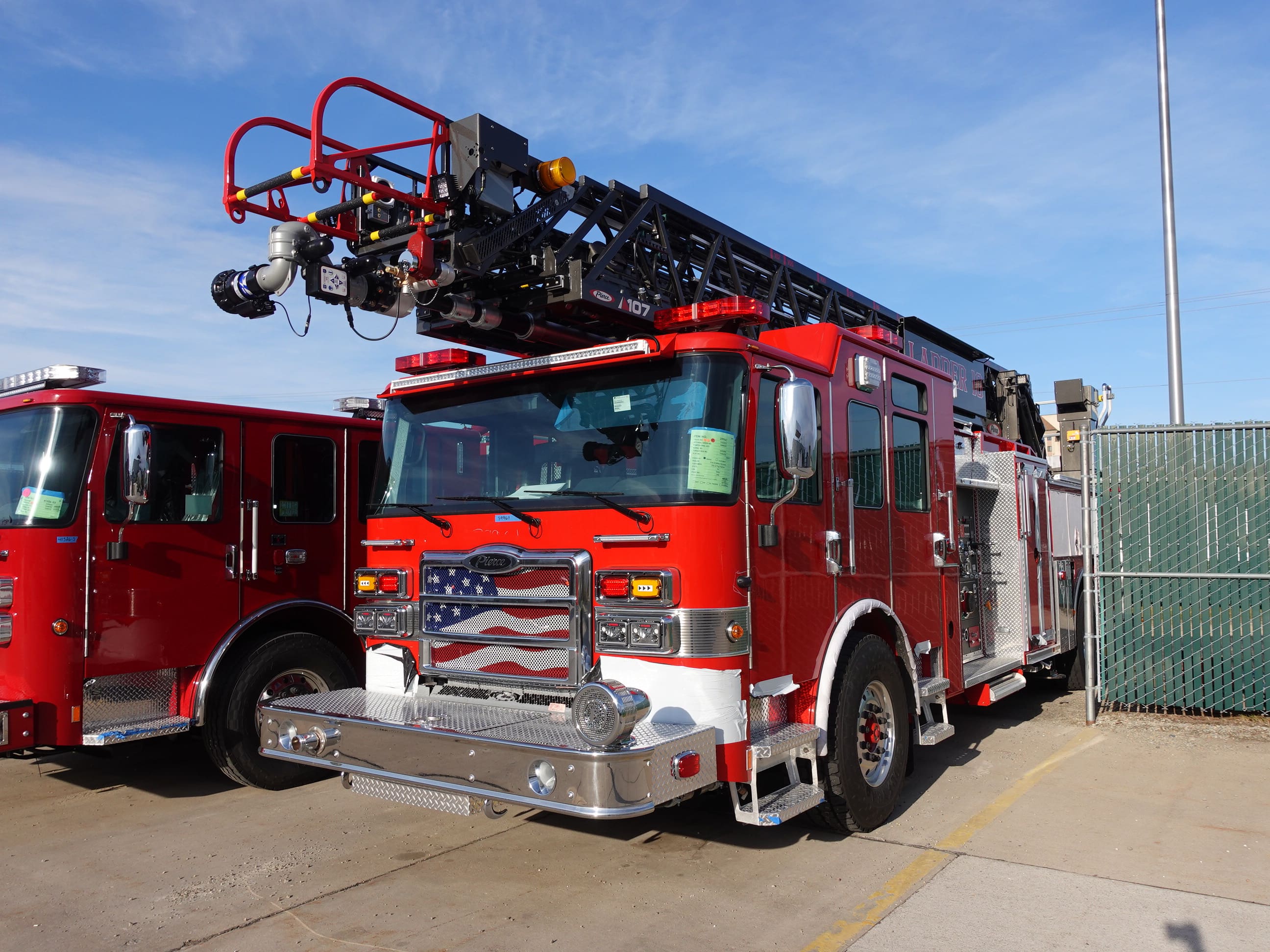

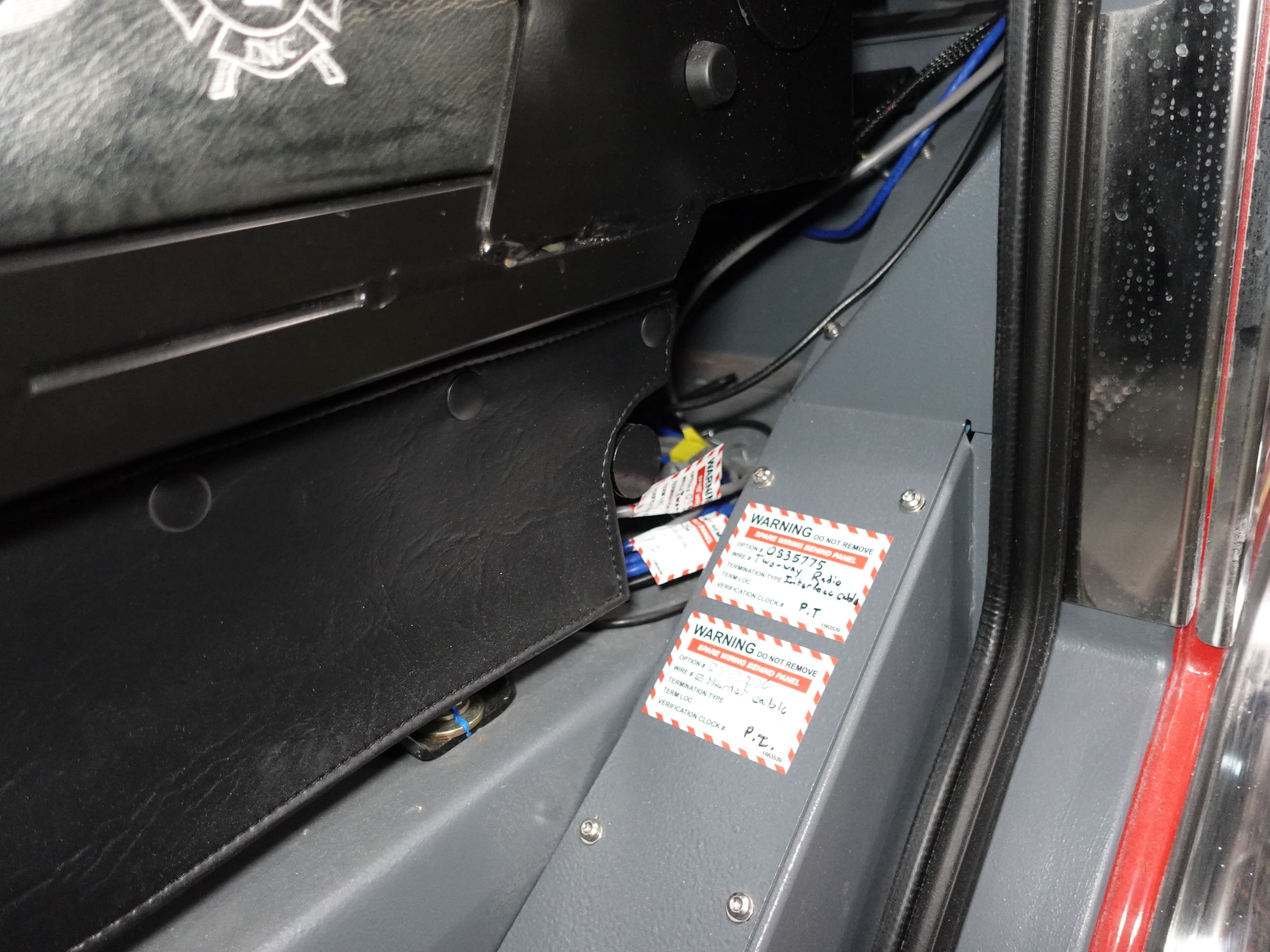

inspection. This is the last scheduled report.
04-24-26

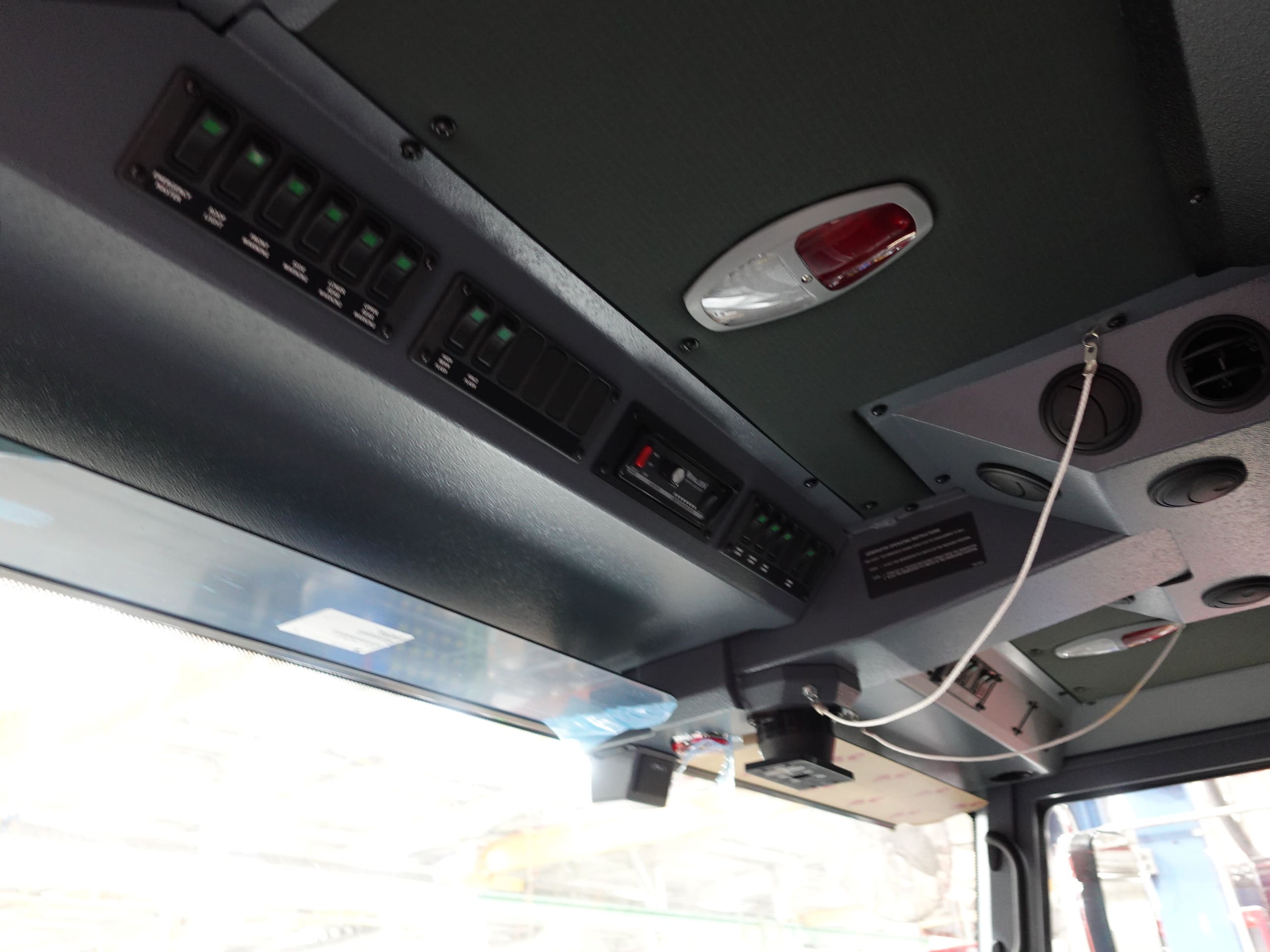

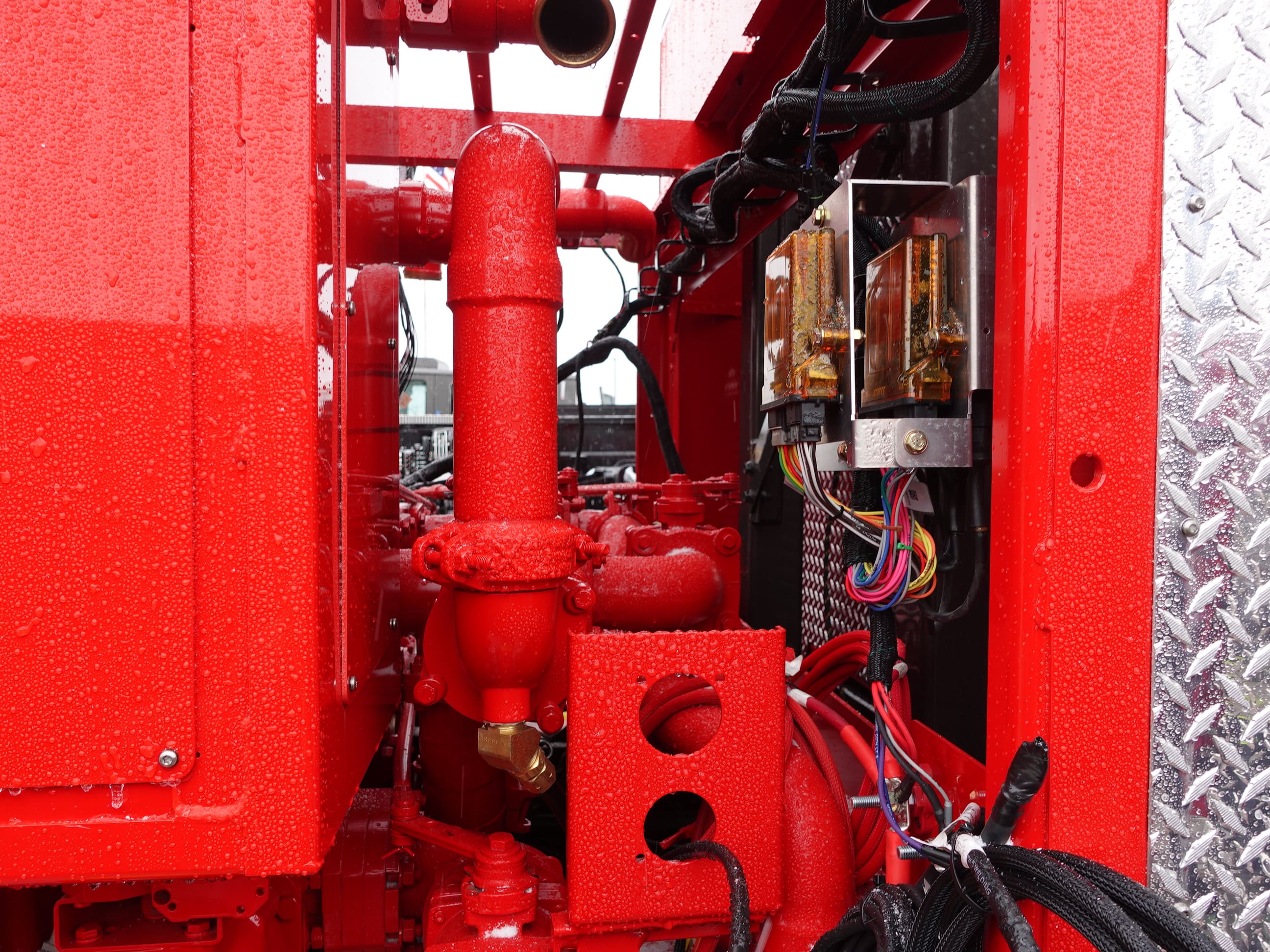

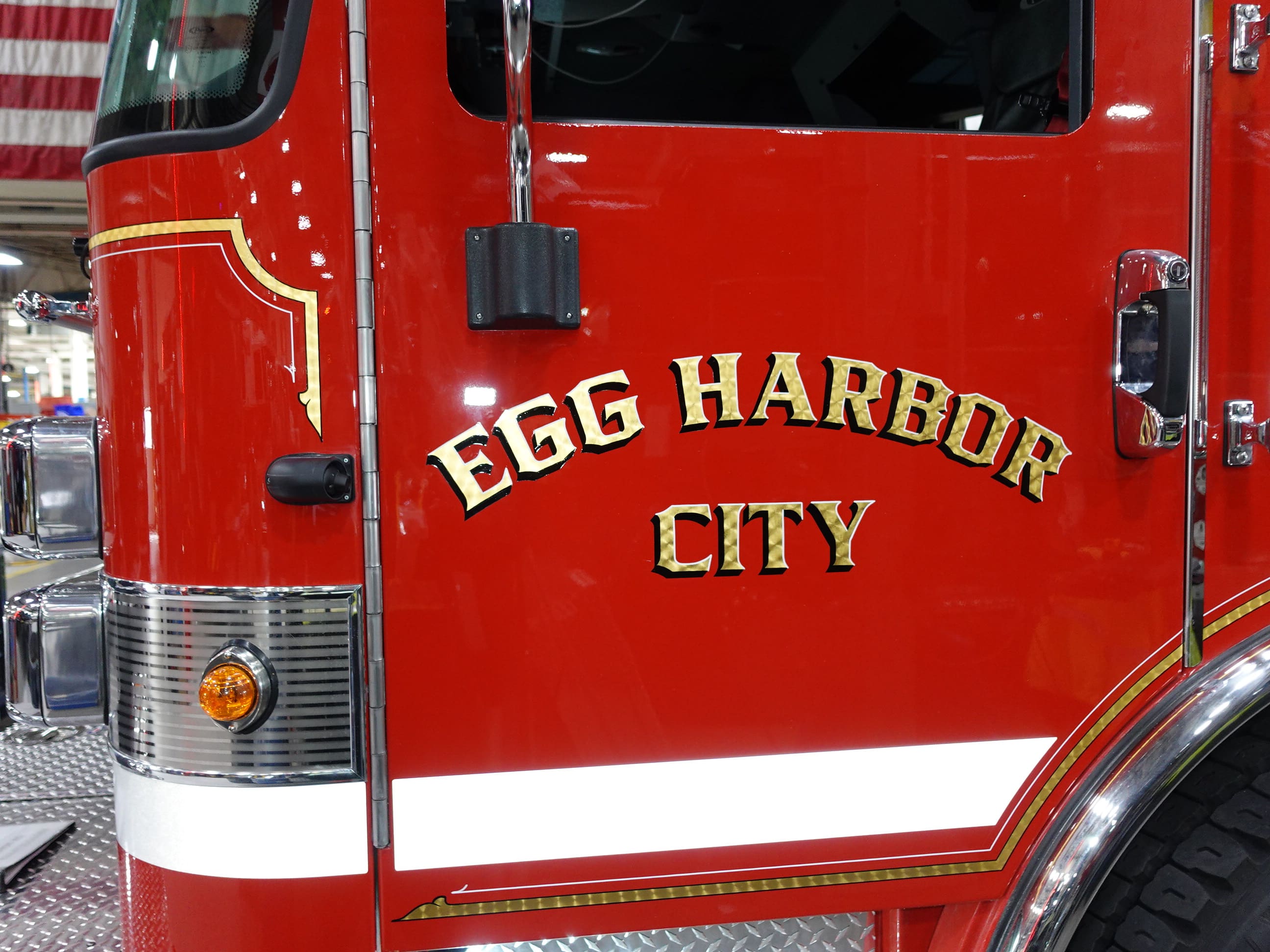

In this report, the hand painted goldleaf graphics were being applied to your apparatus.

04-10-26

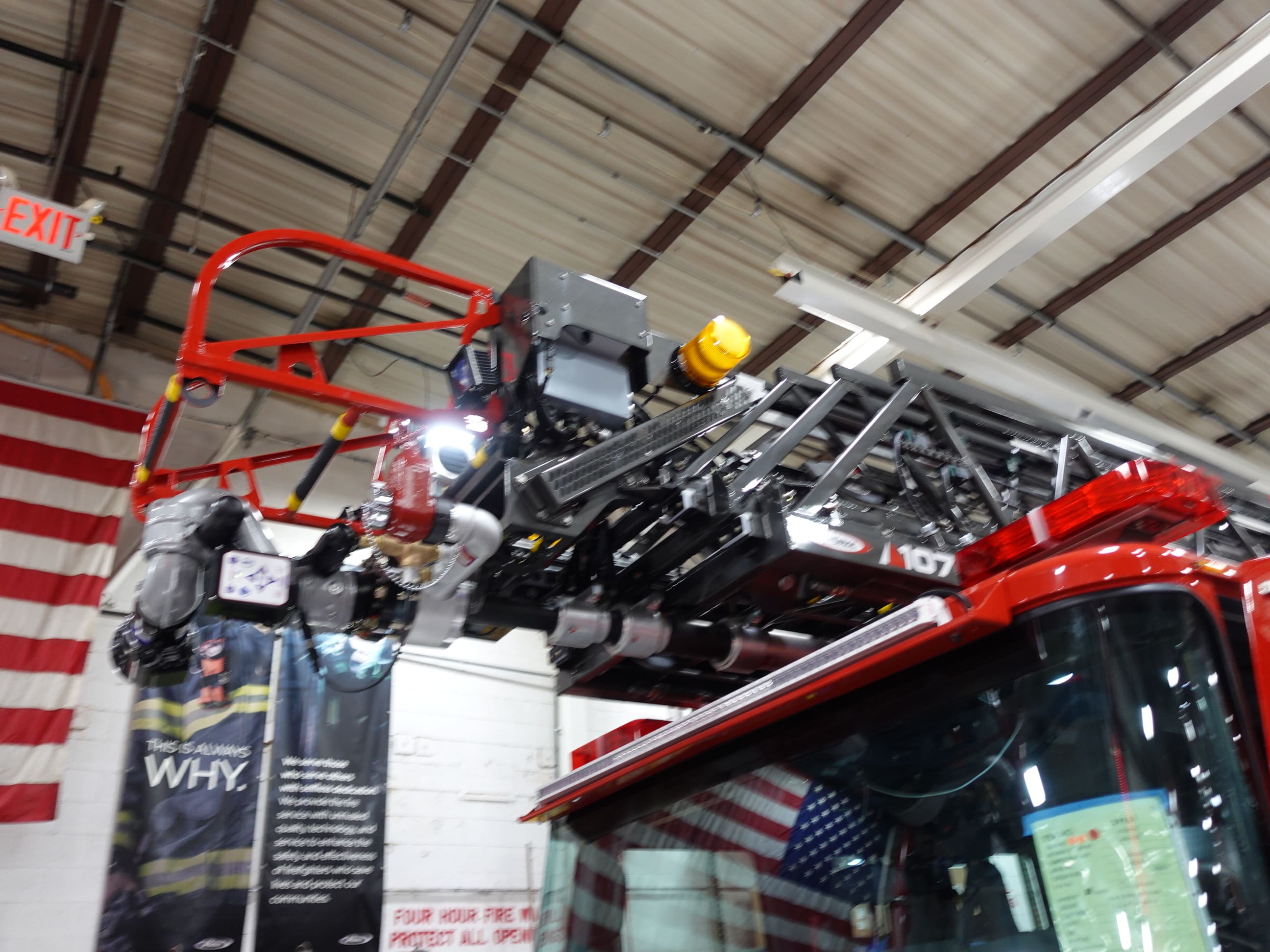

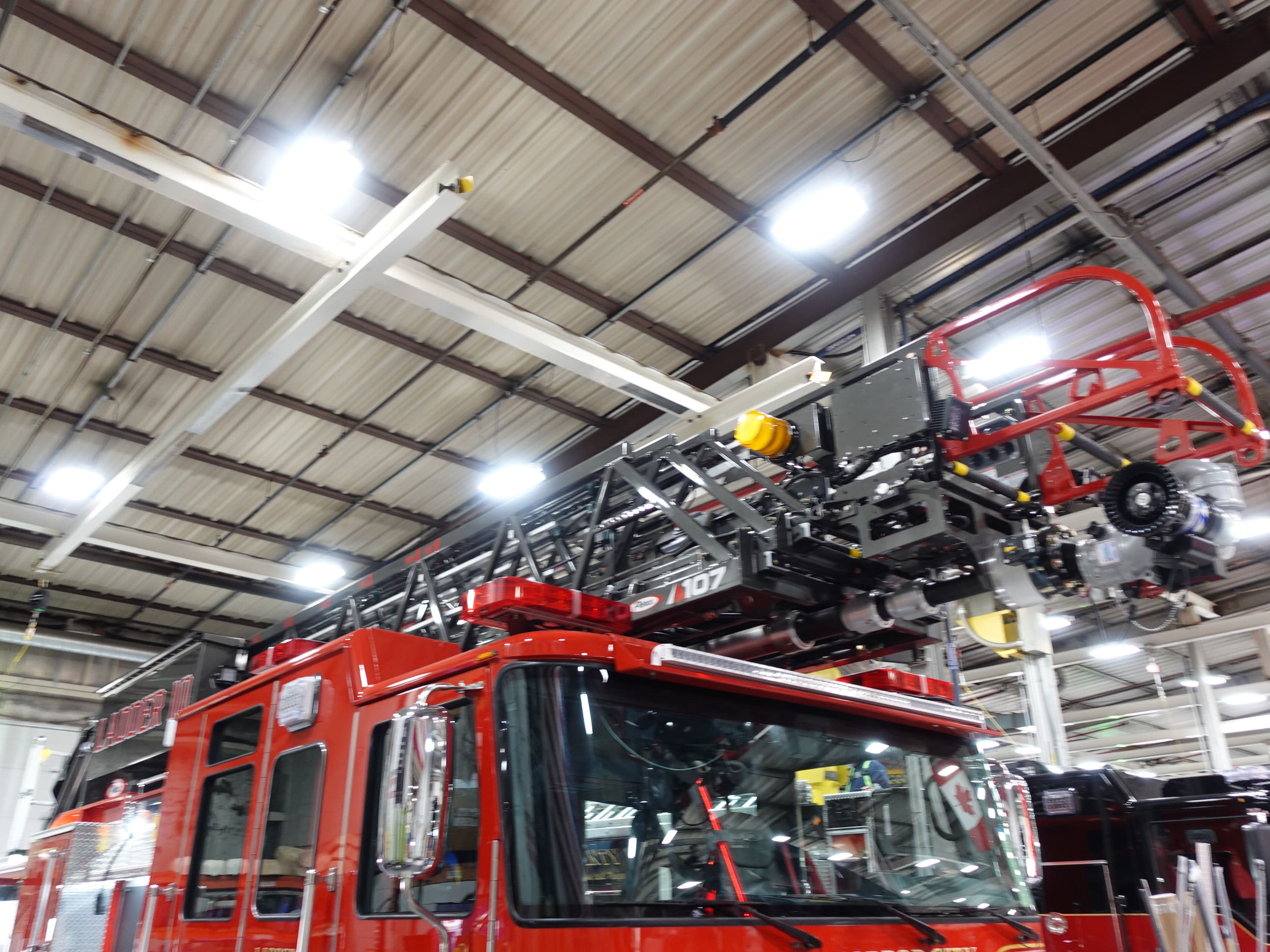

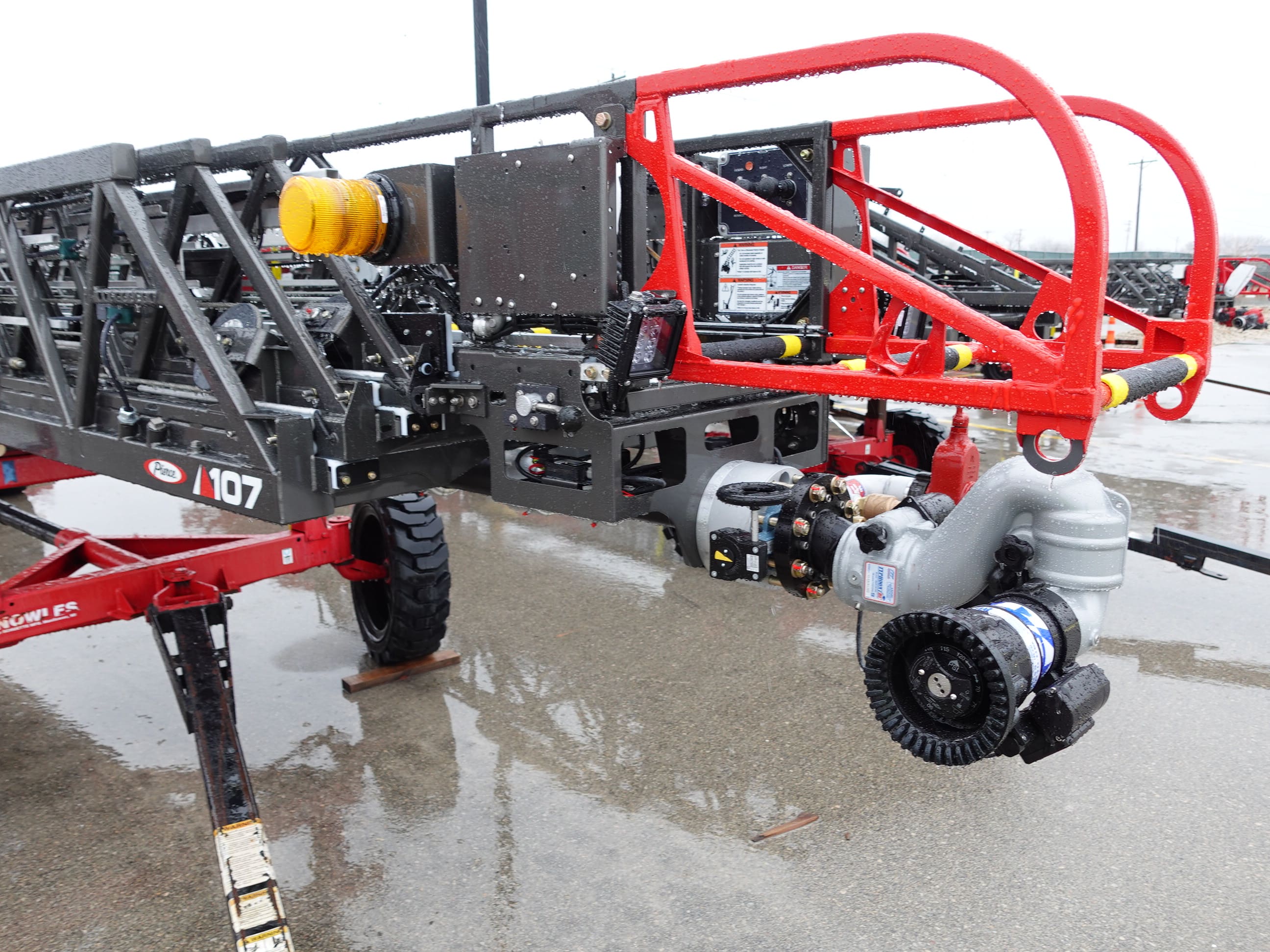

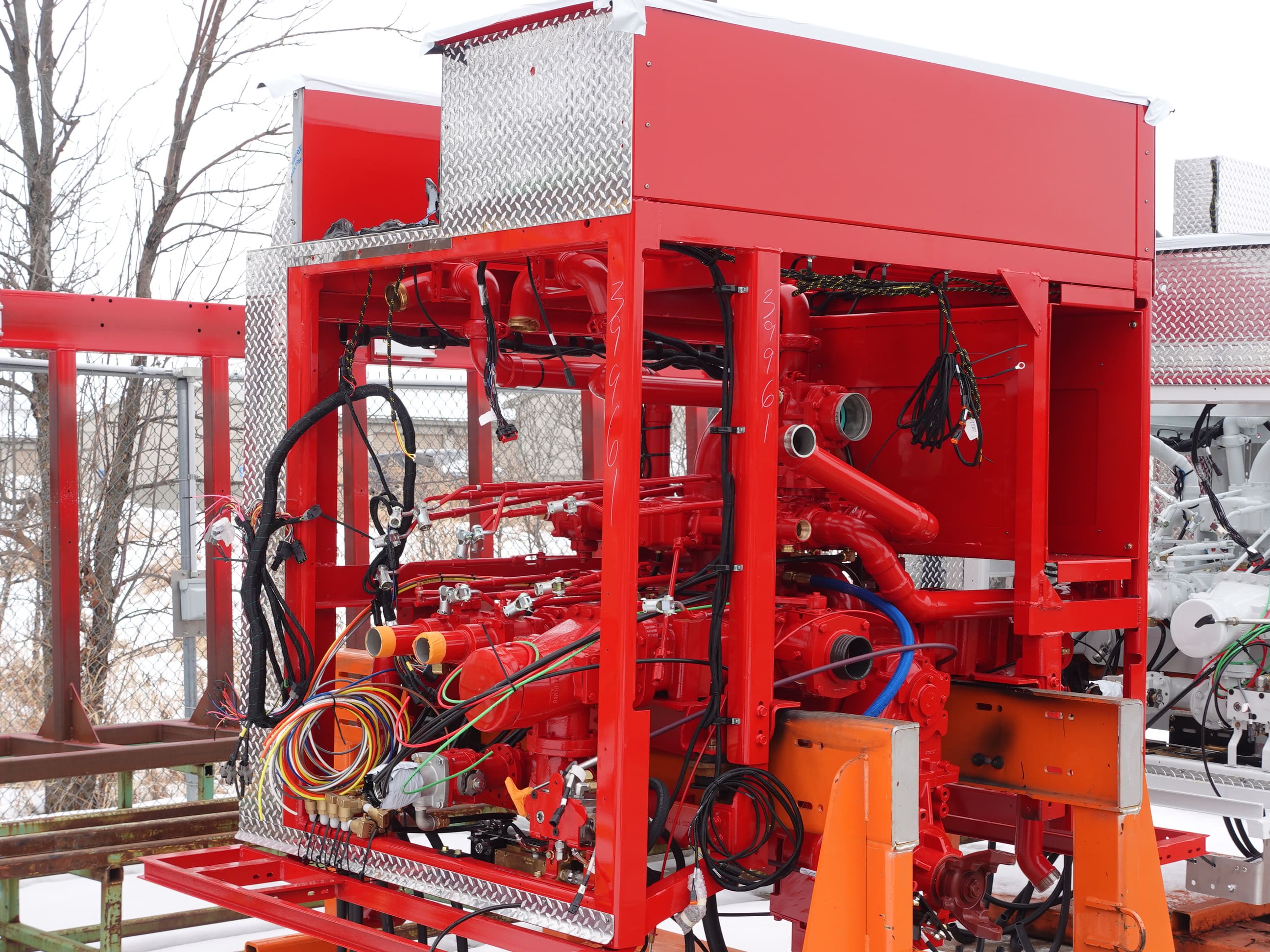

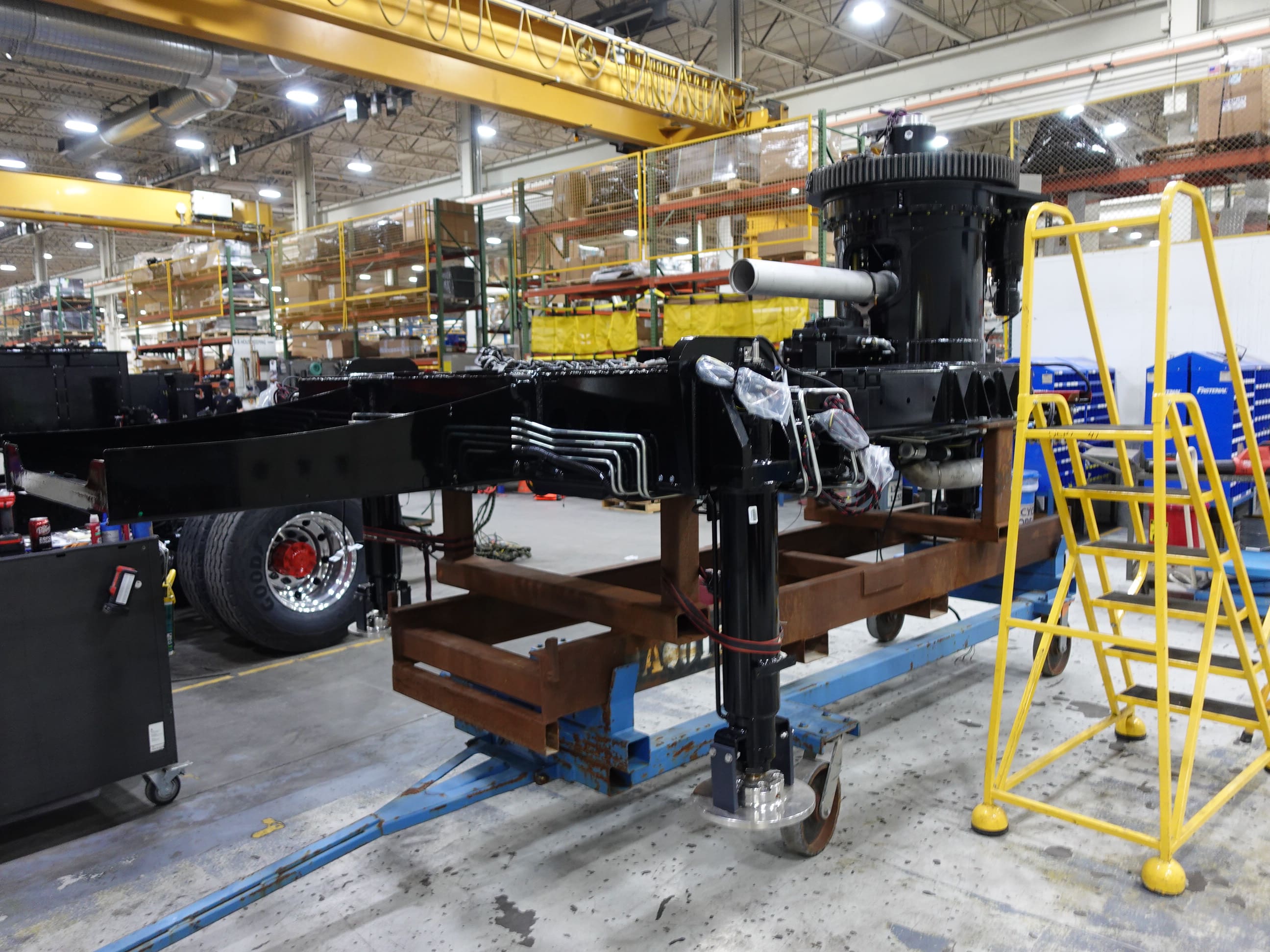

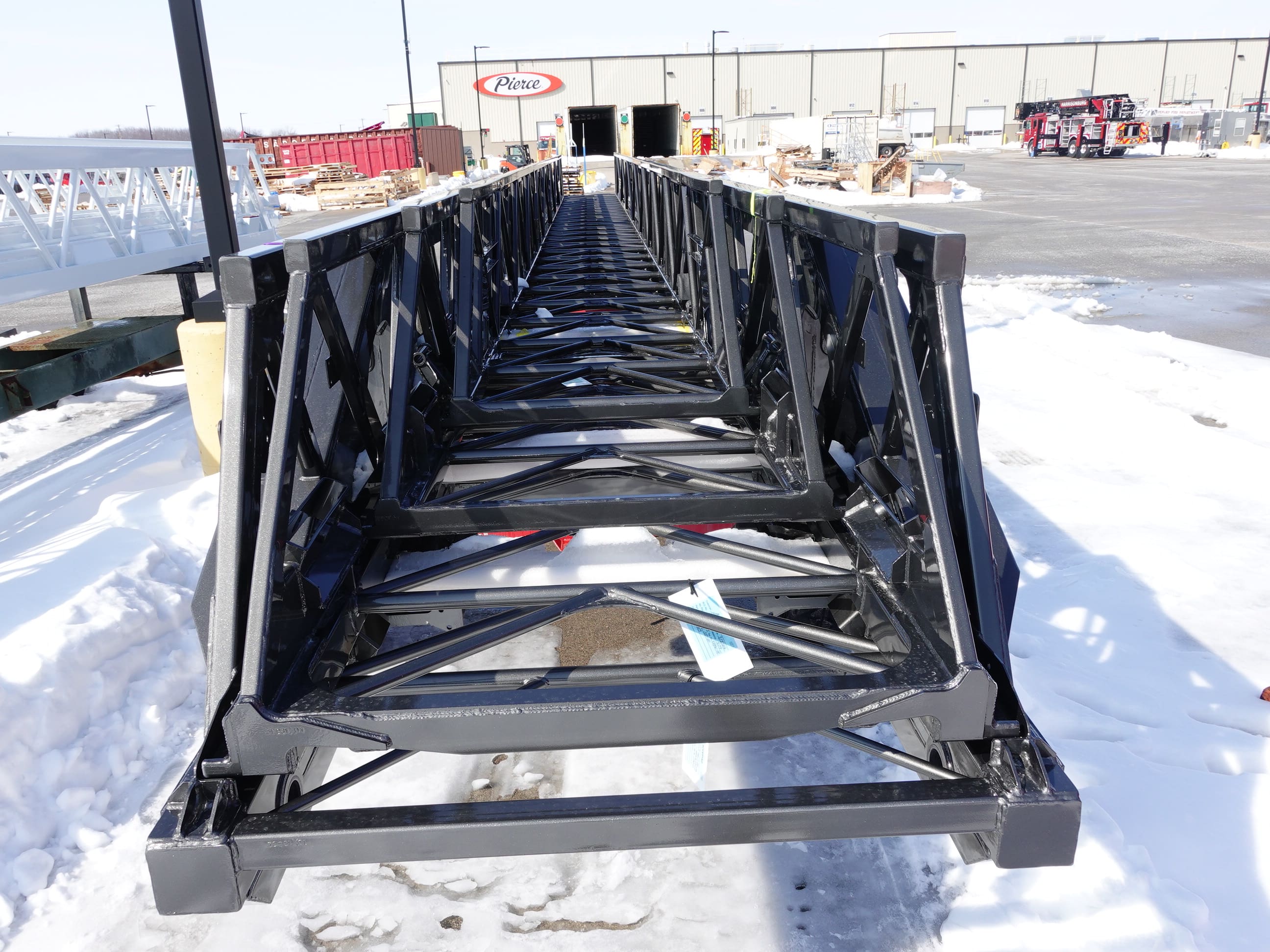

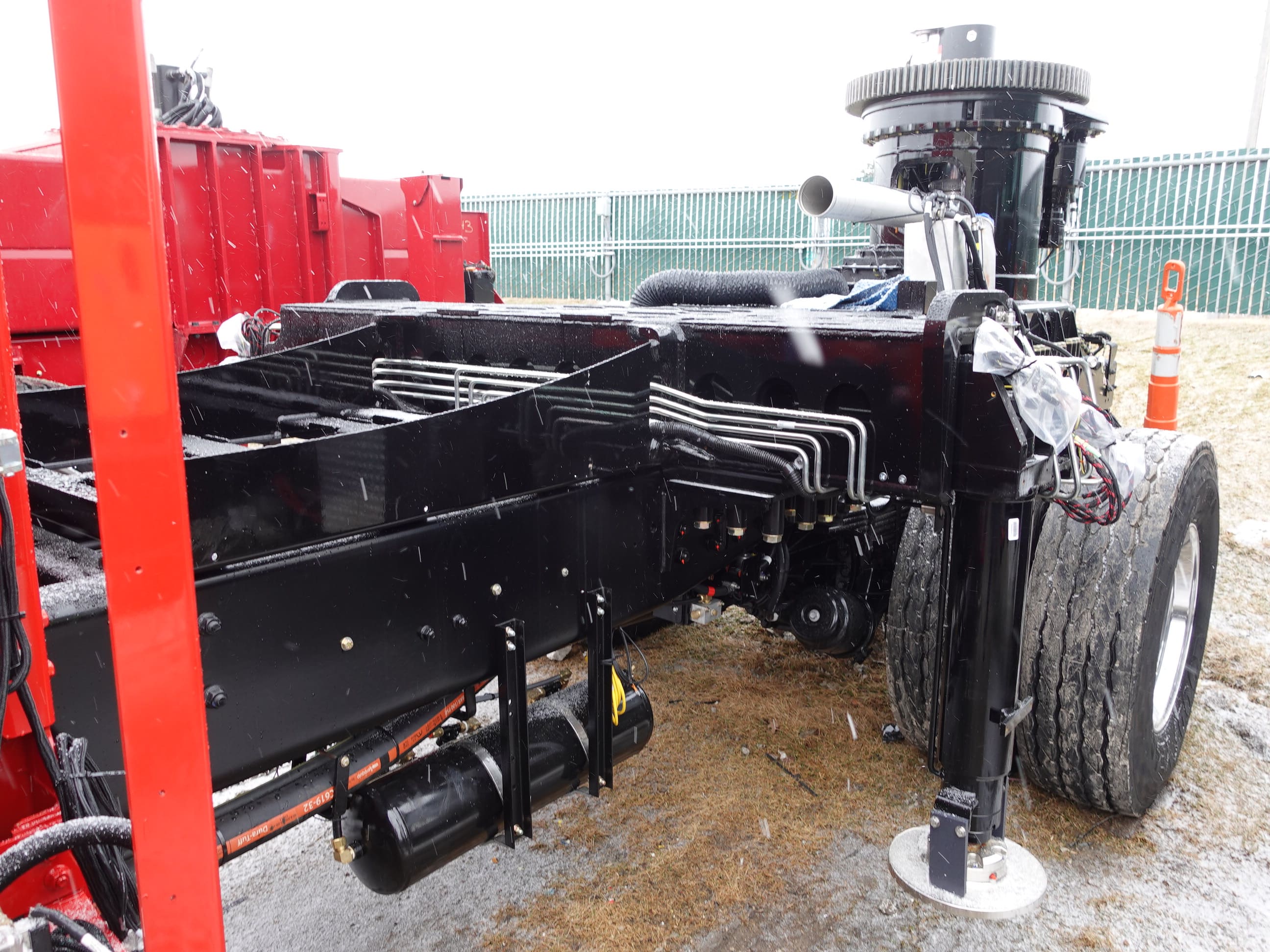

In this report, the aerial device was pinned to the apparatus followed by the start of testing.

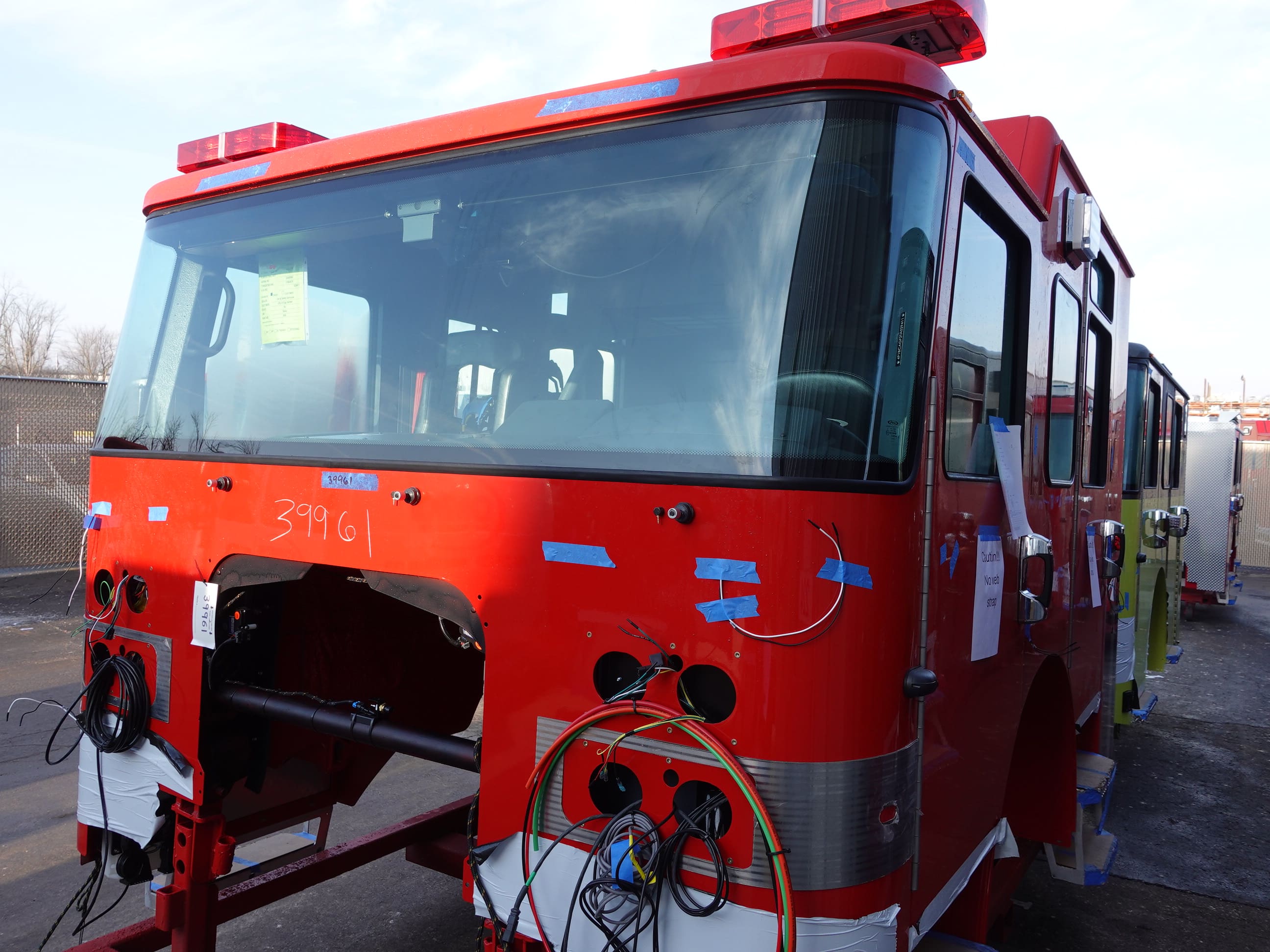

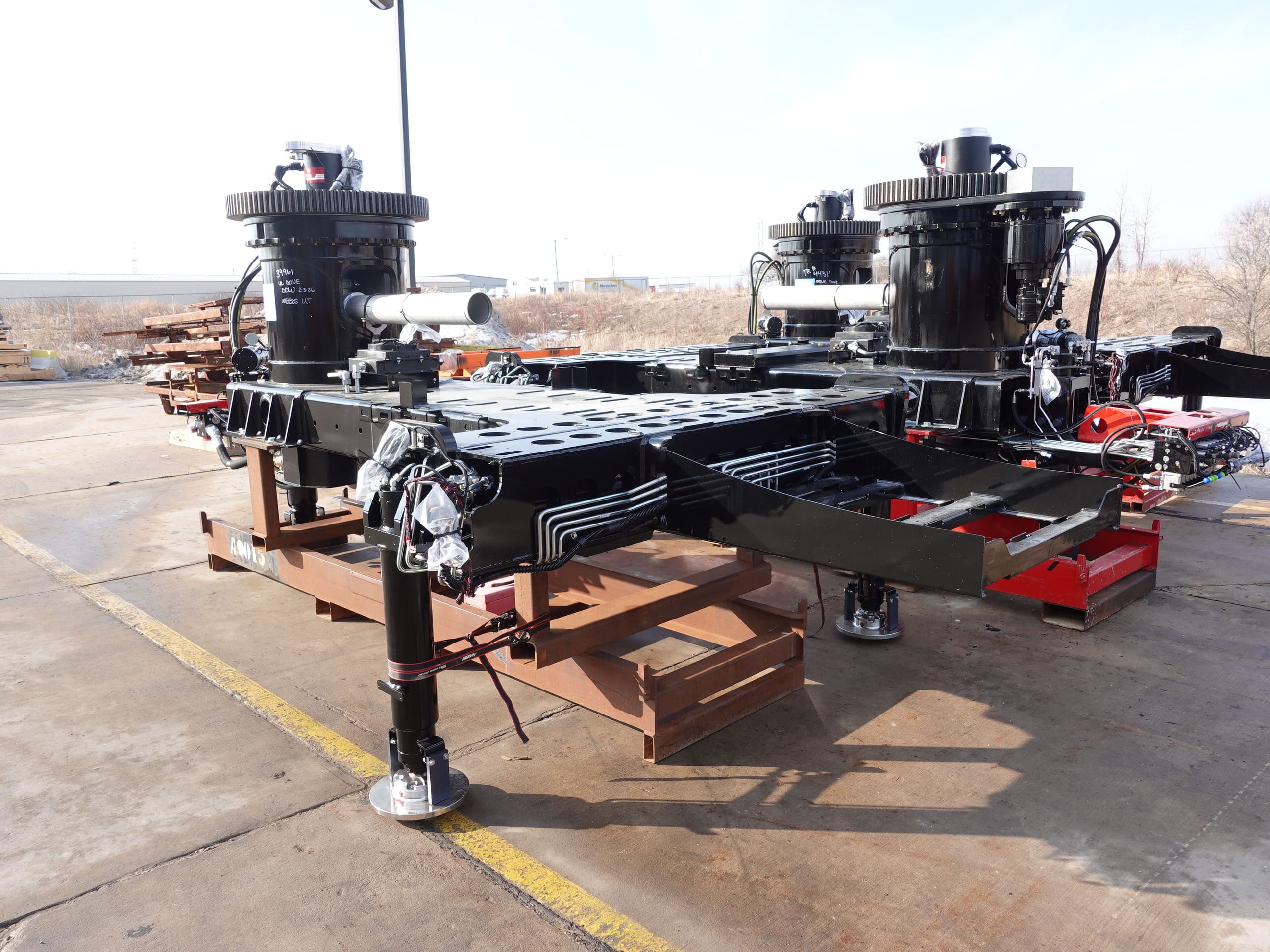

04-03-26

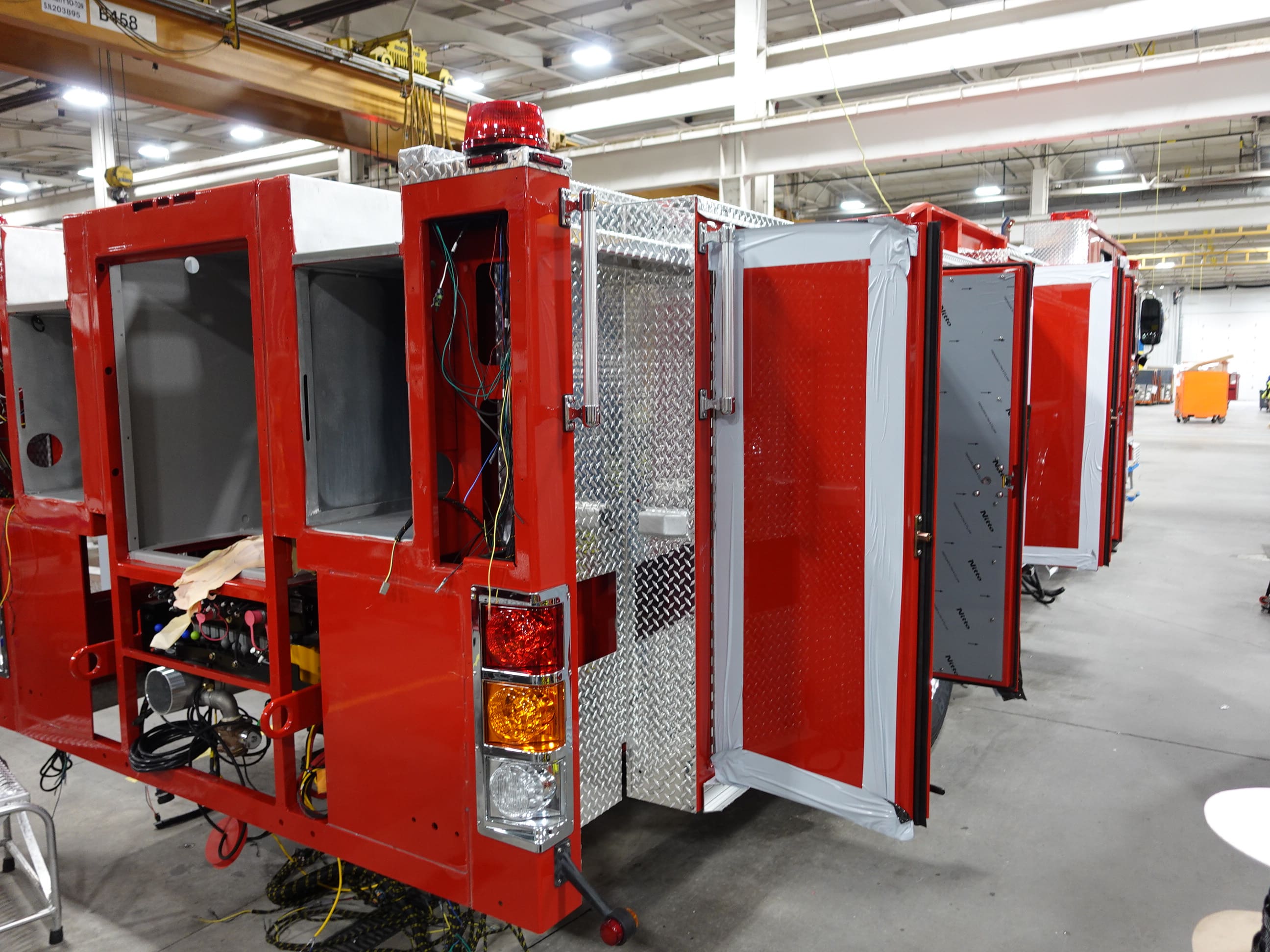

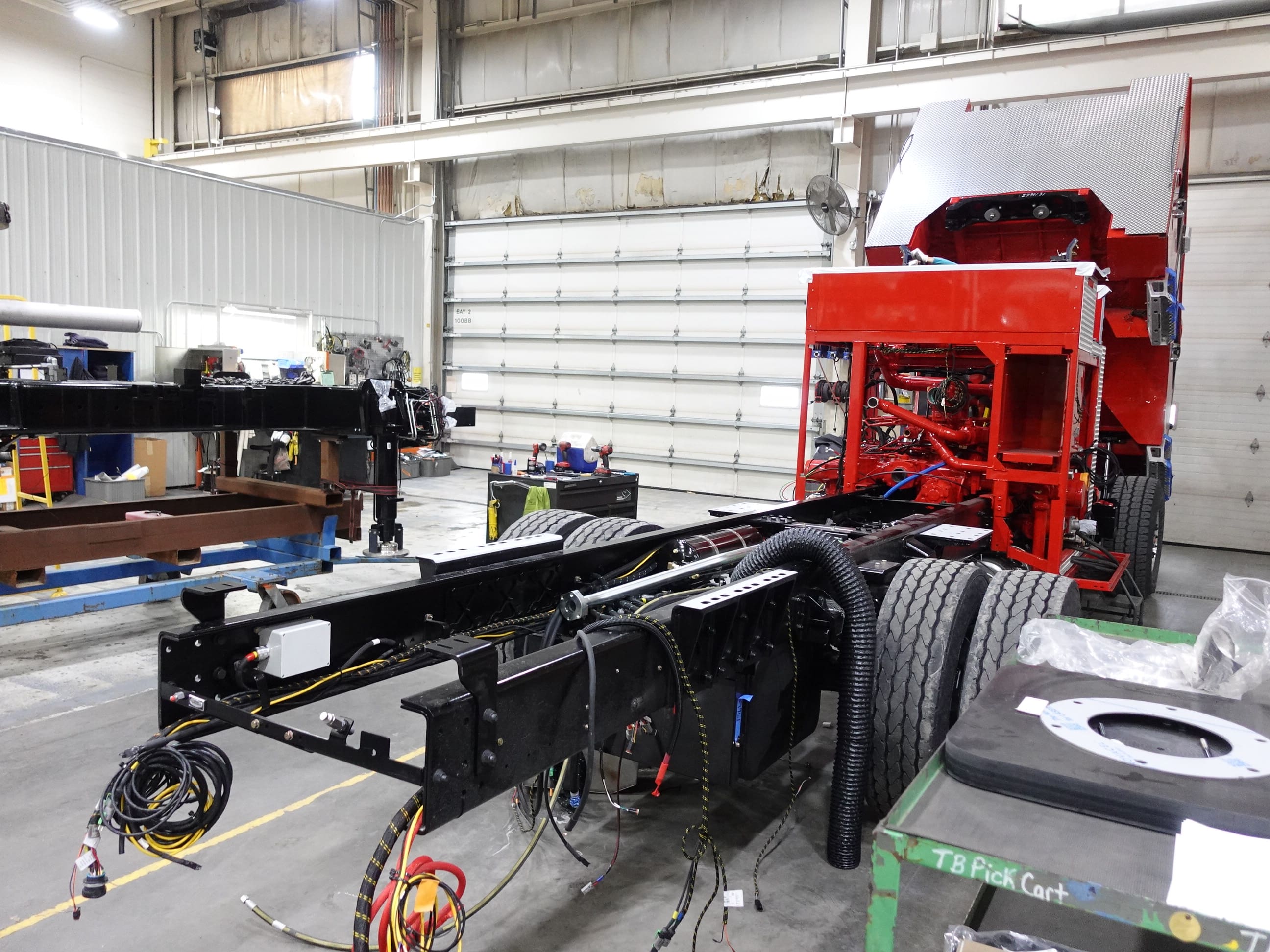

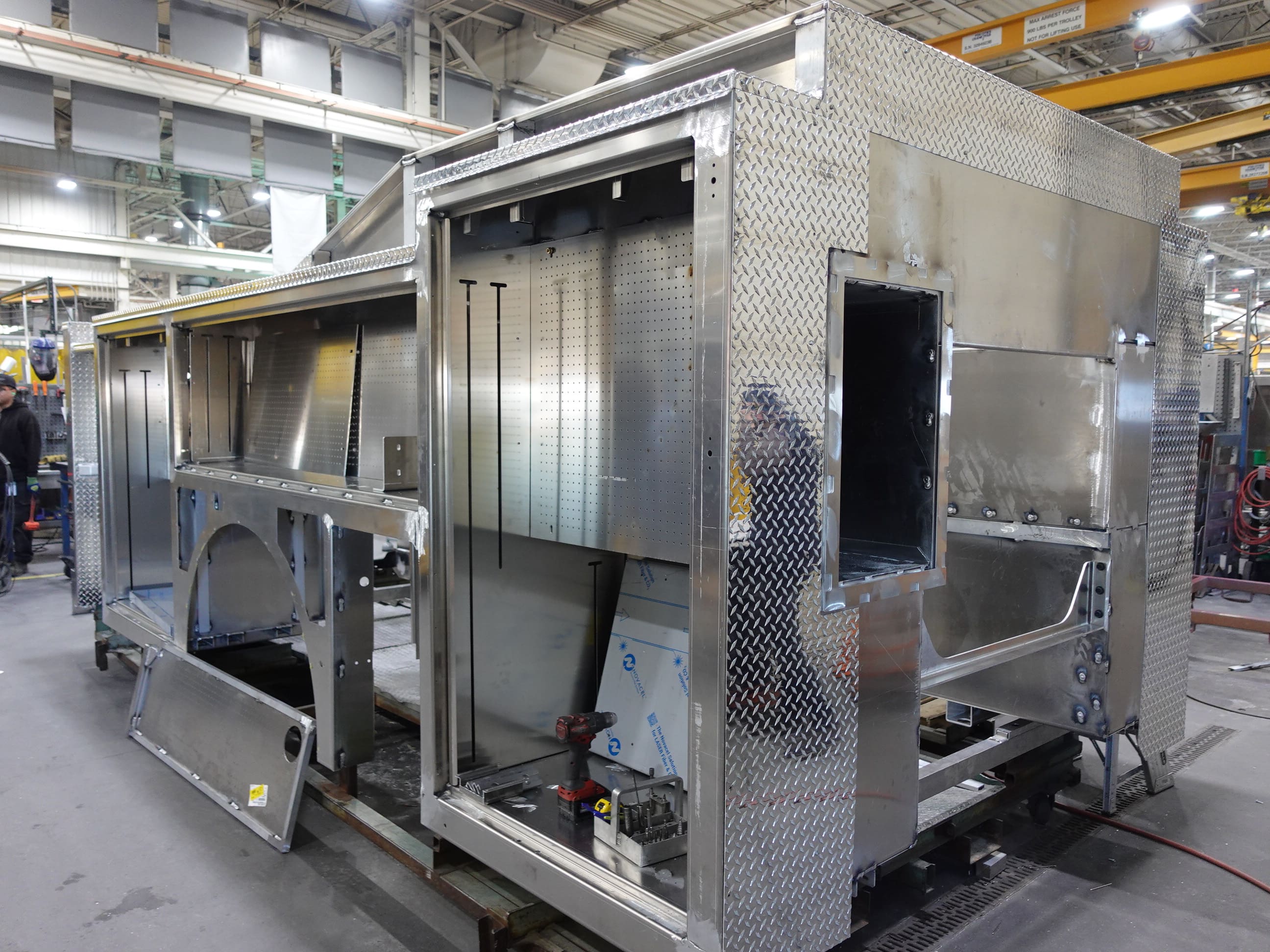

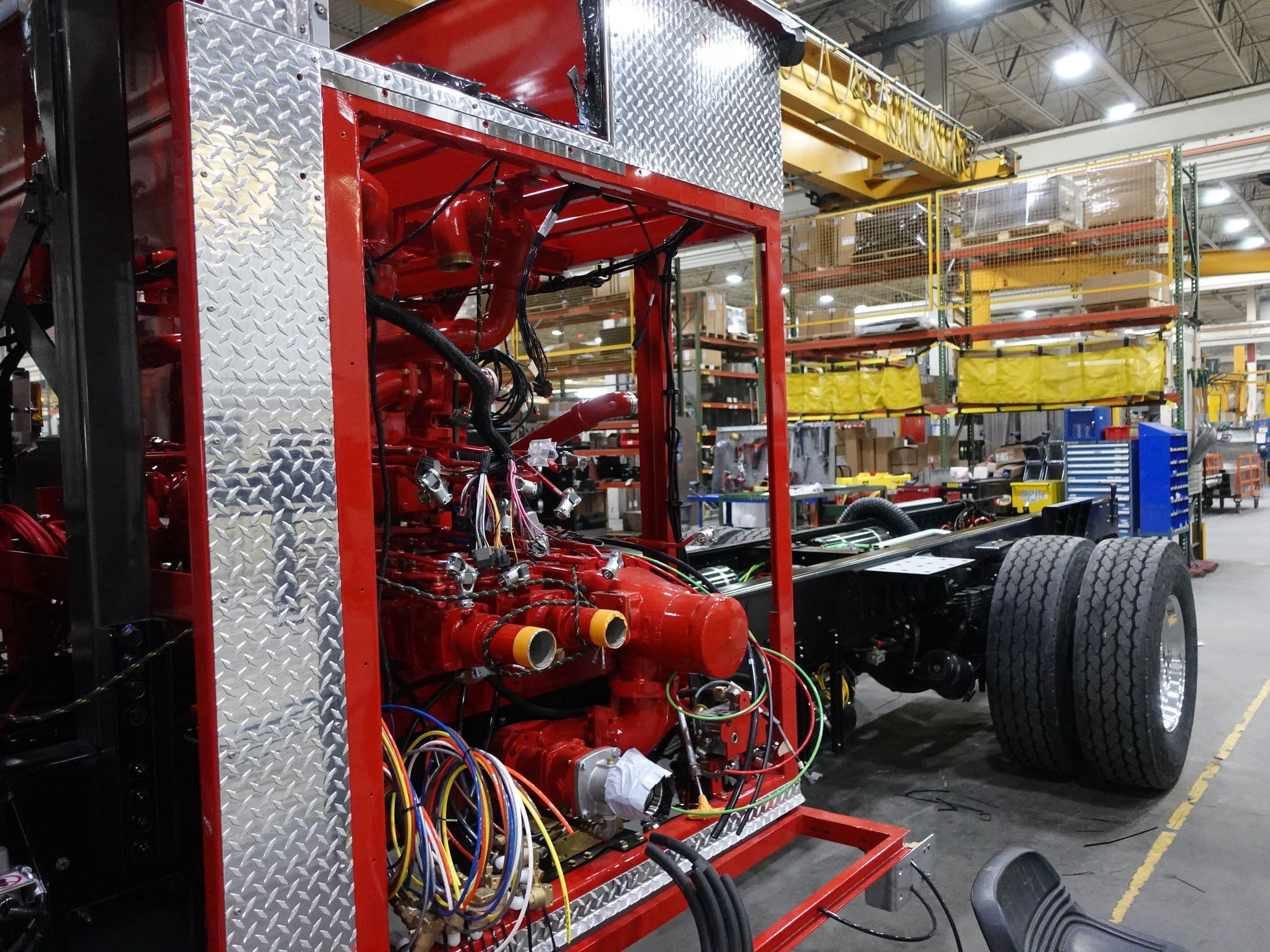

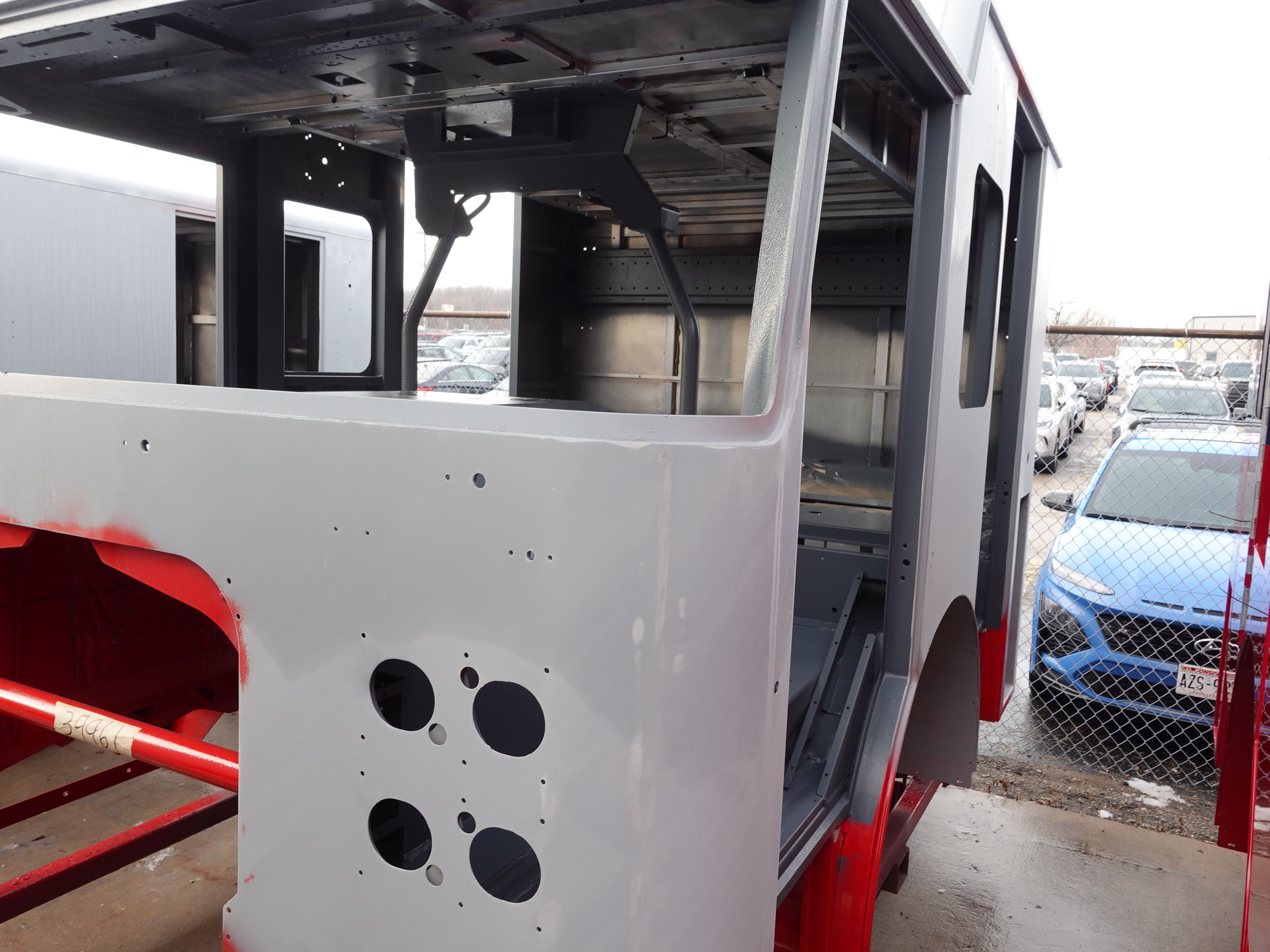

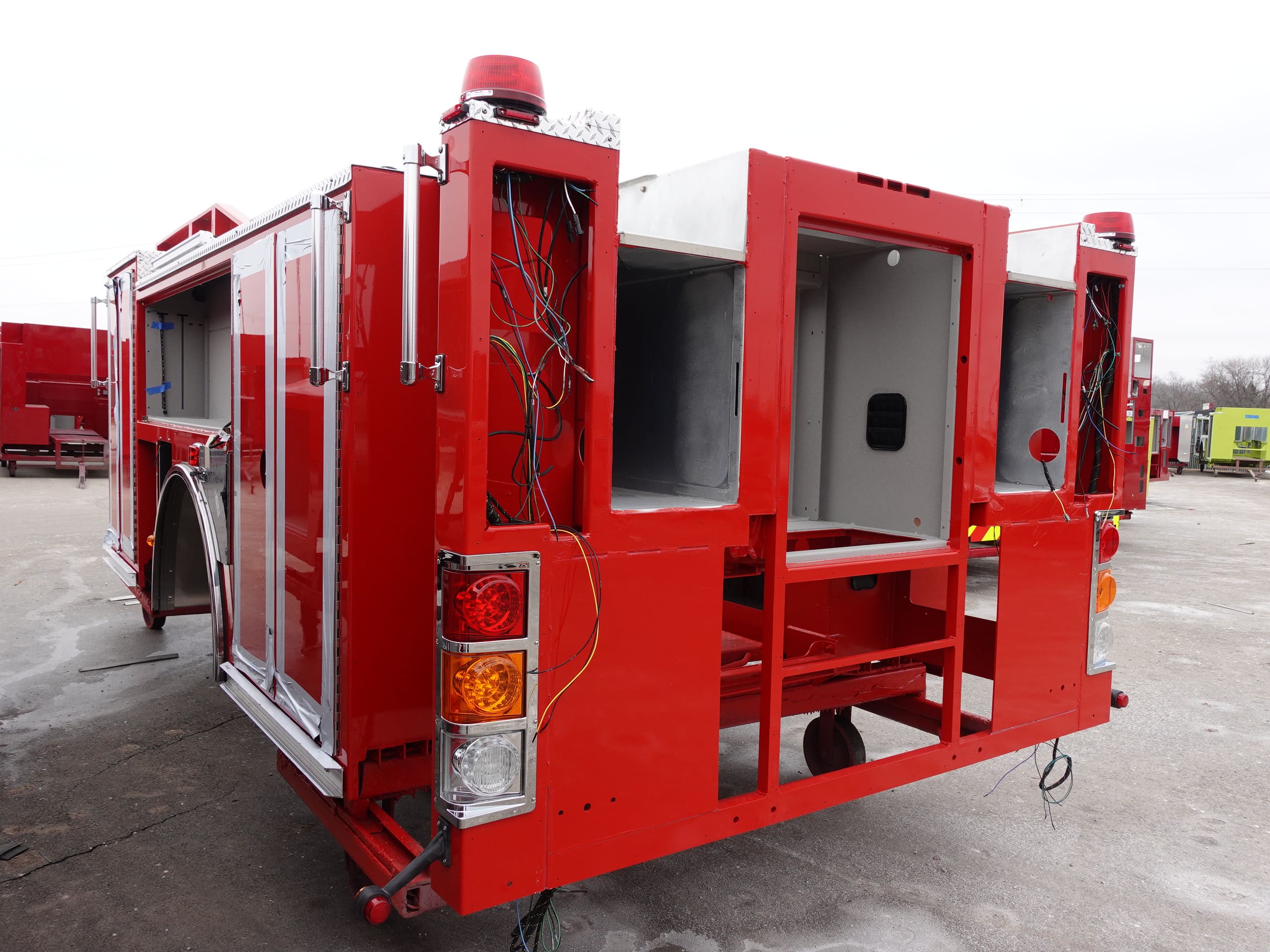

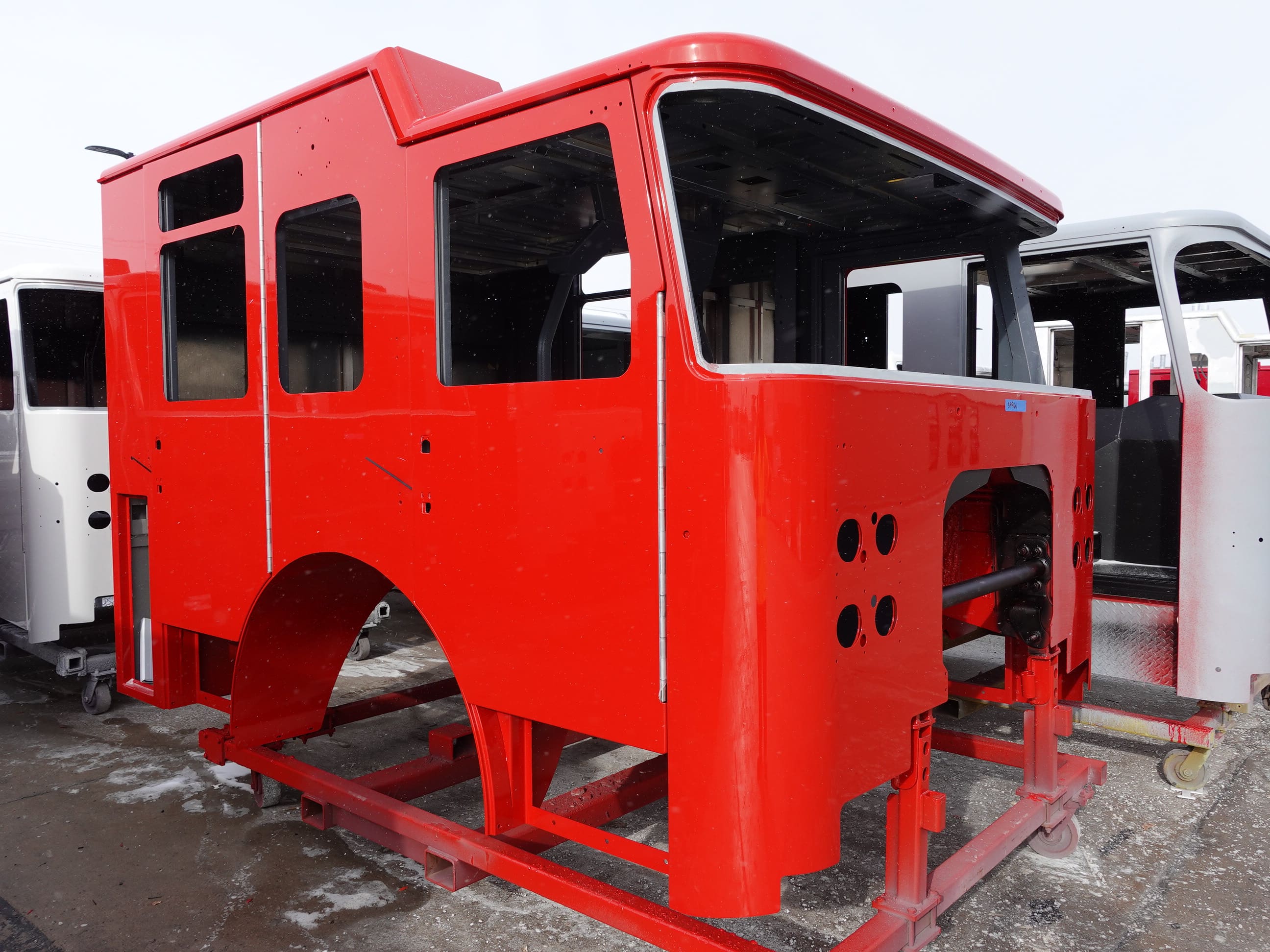

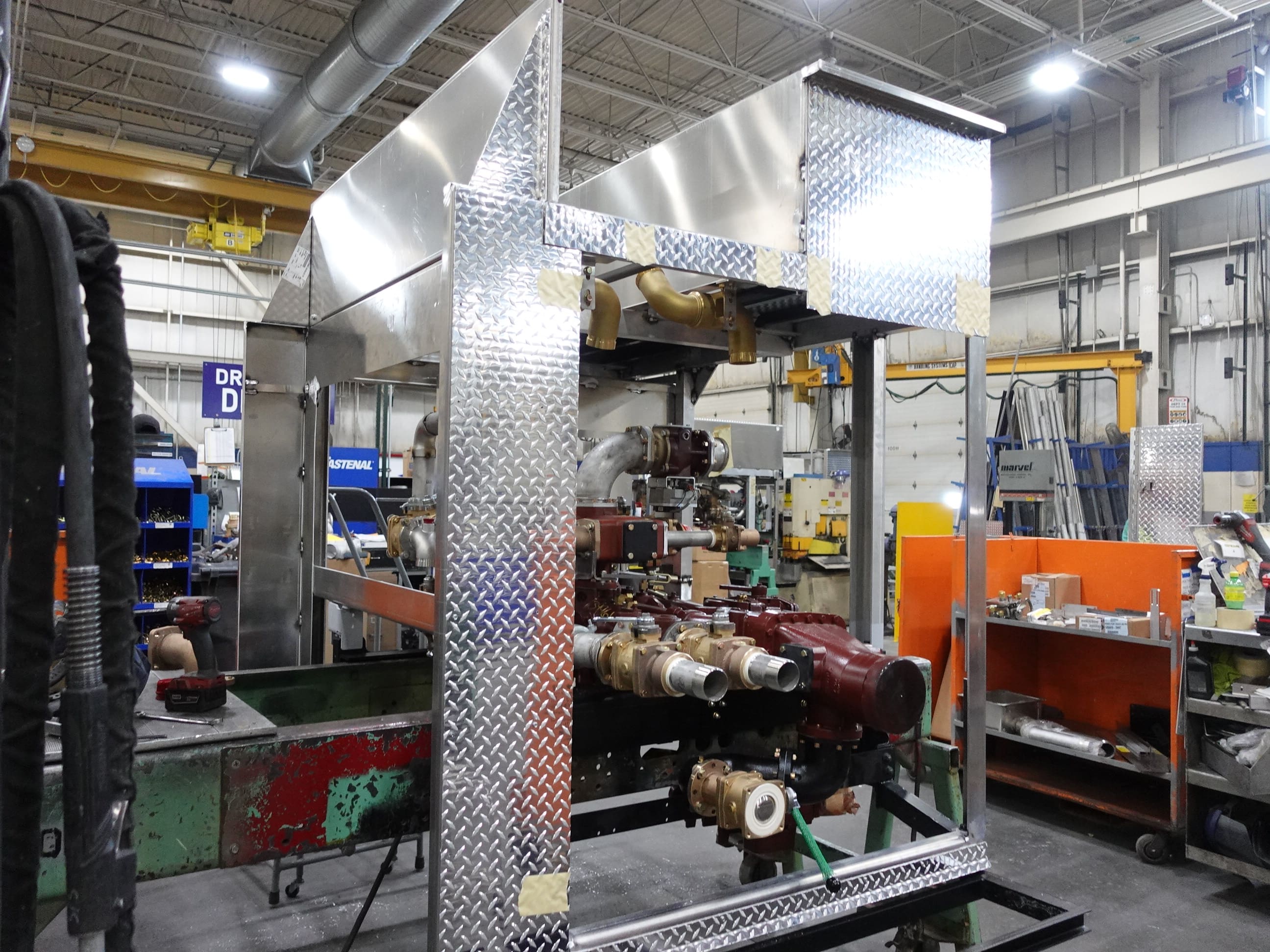

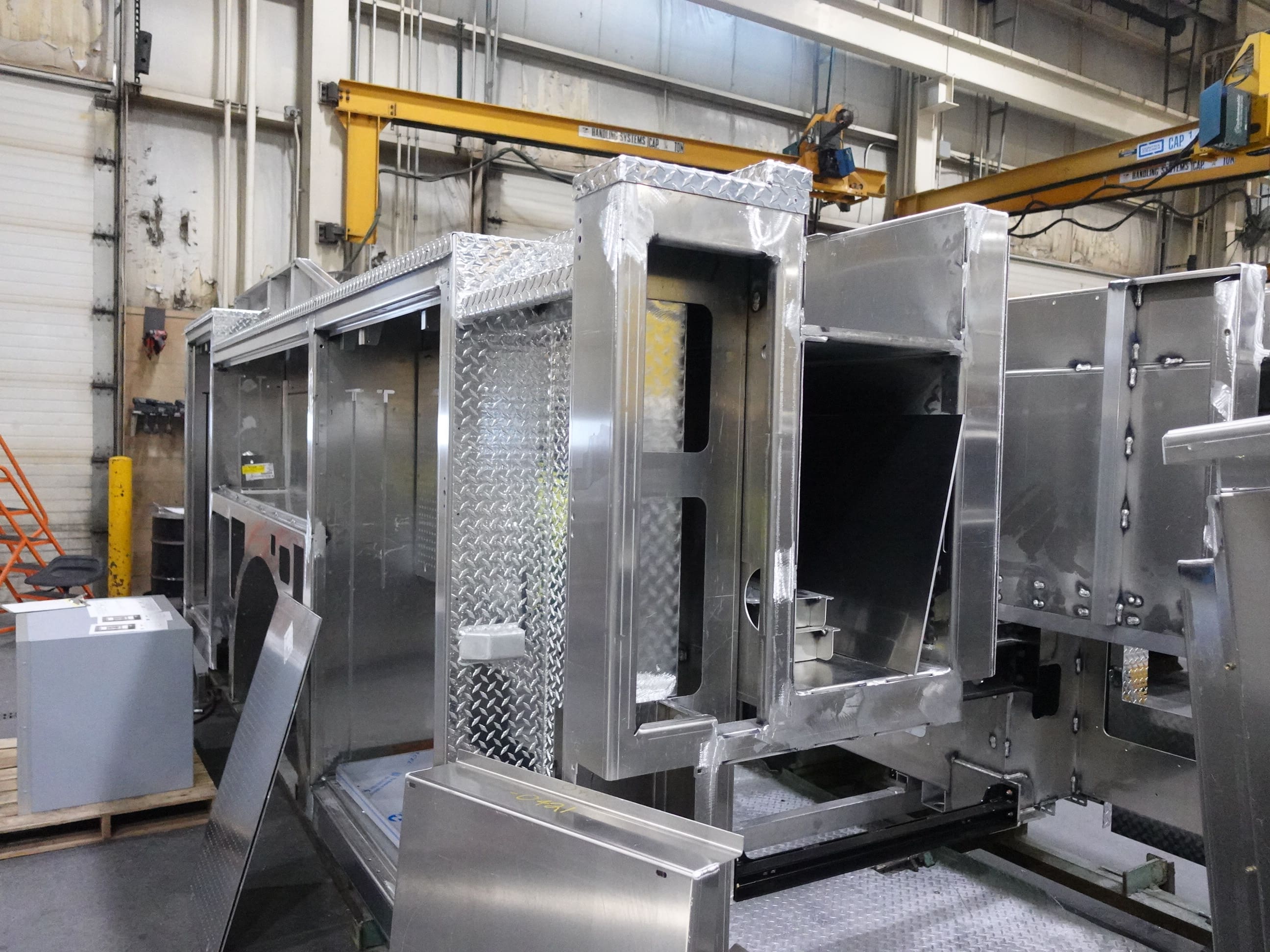

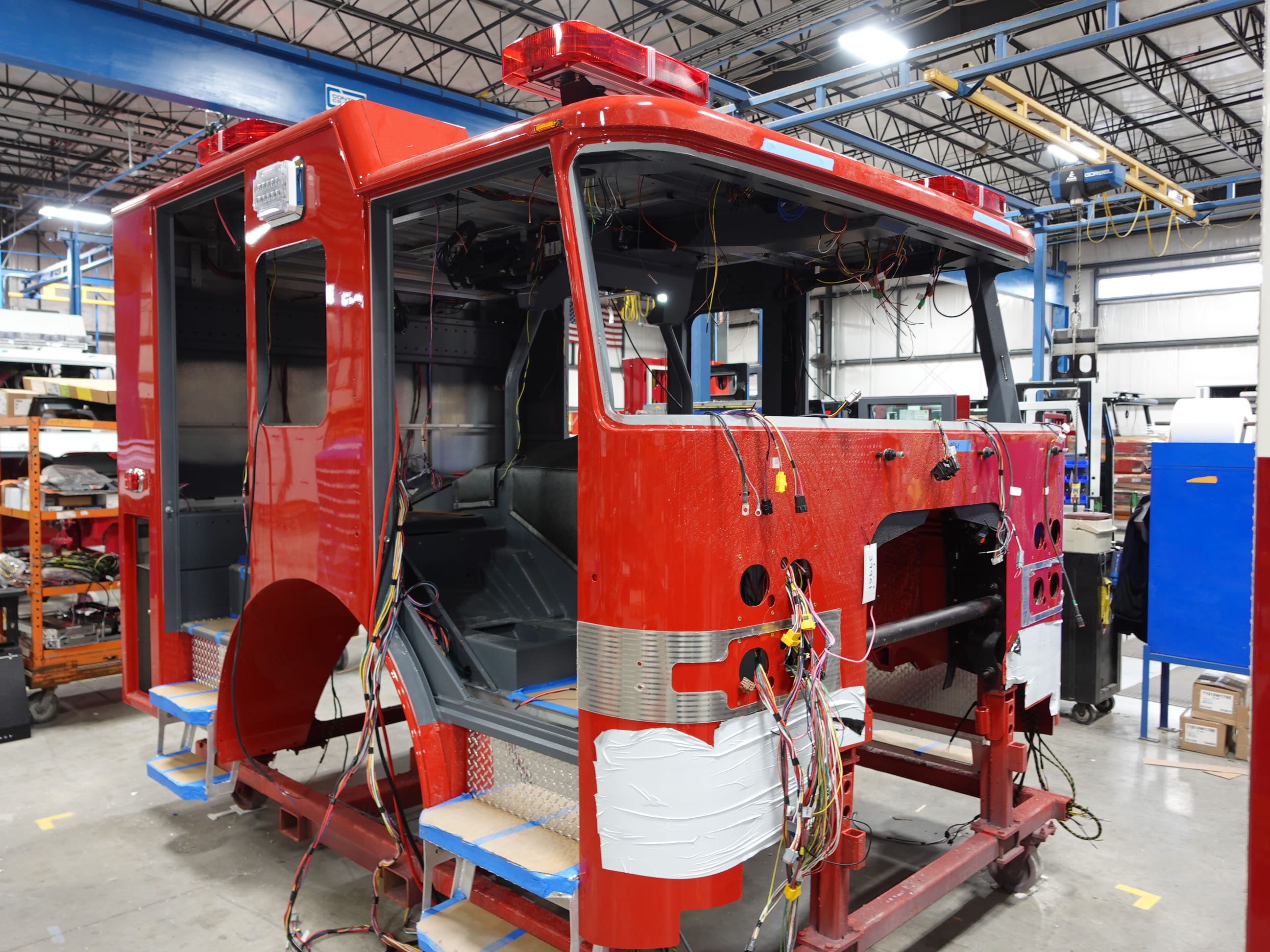

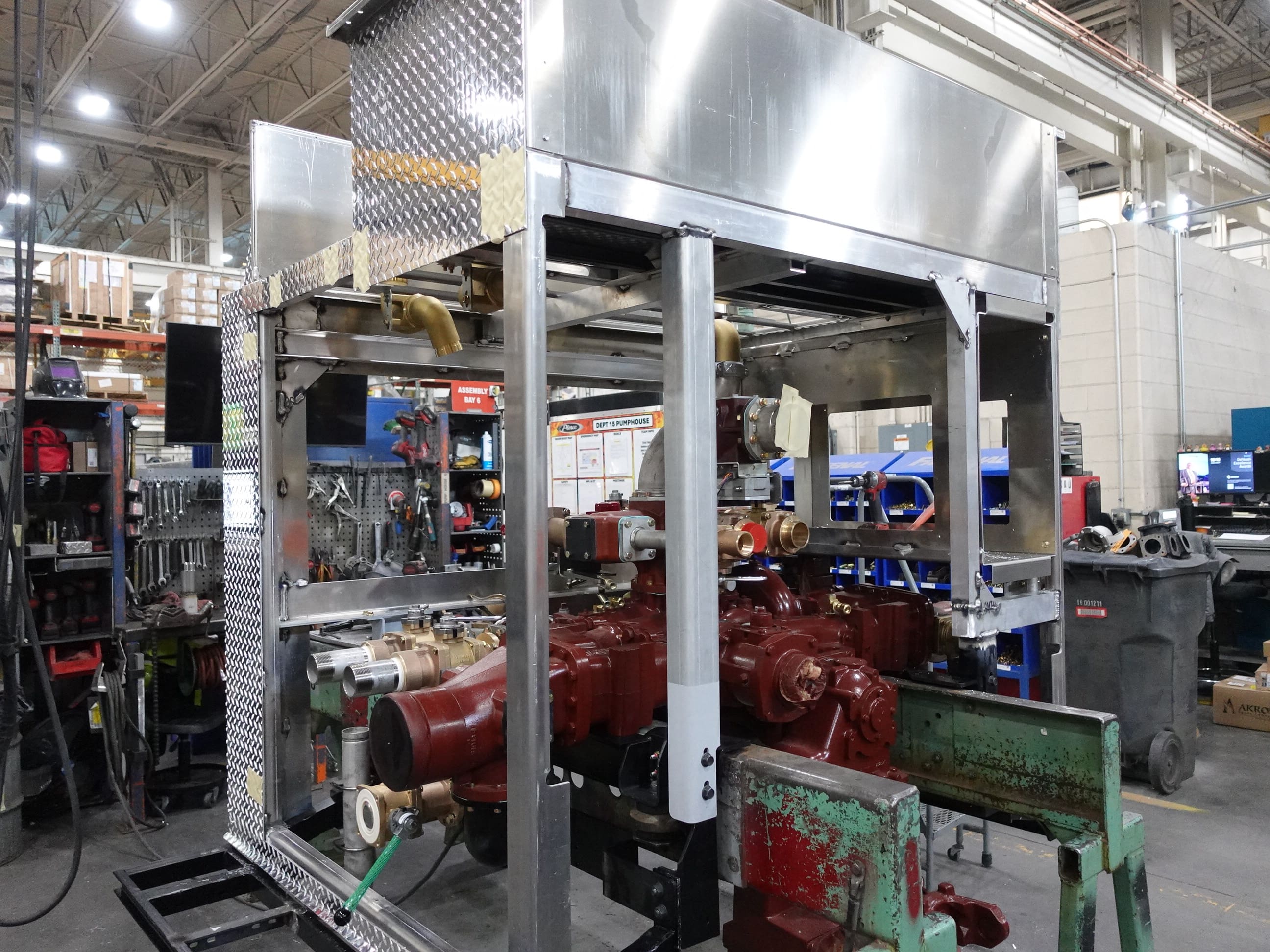

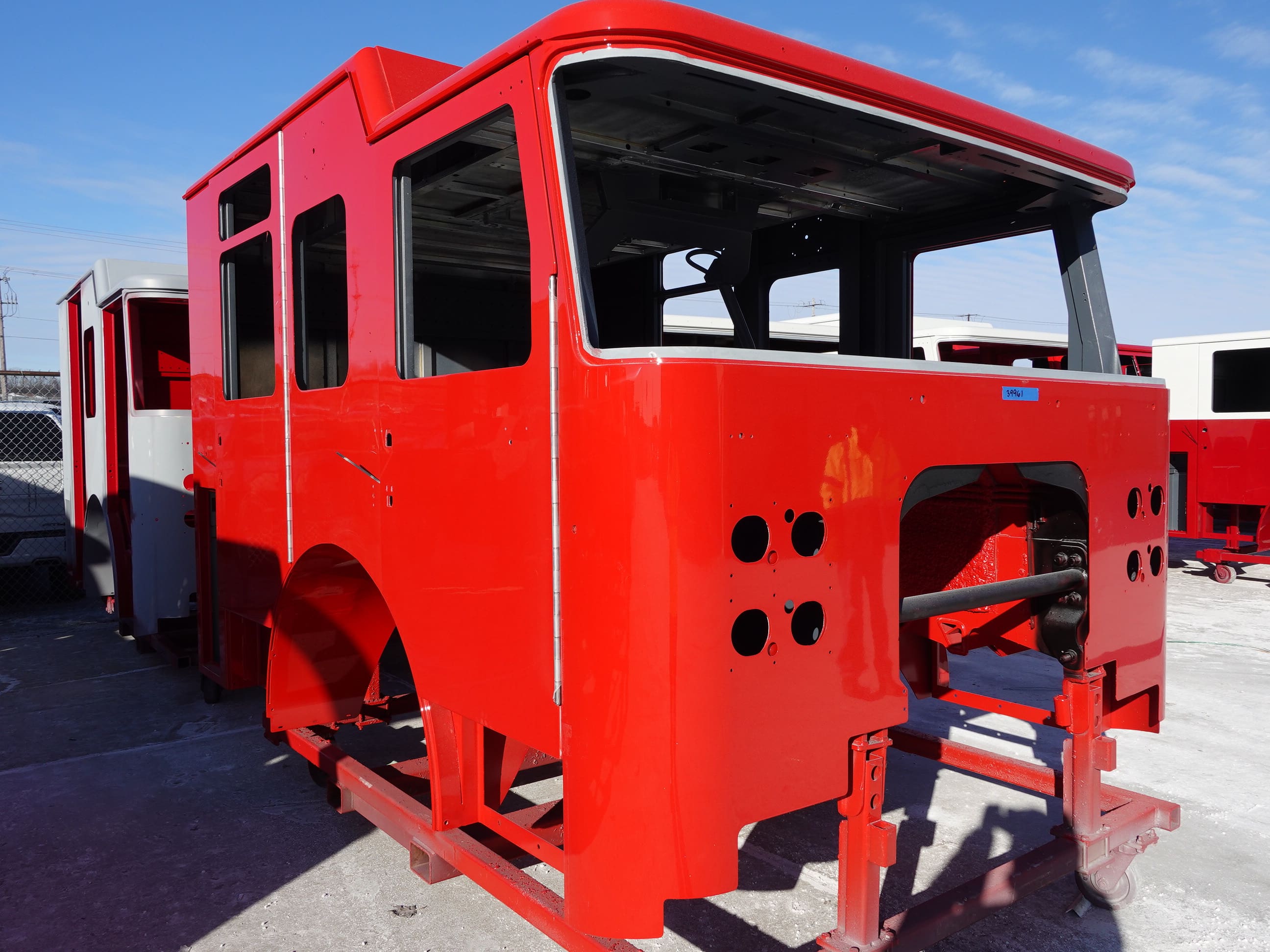

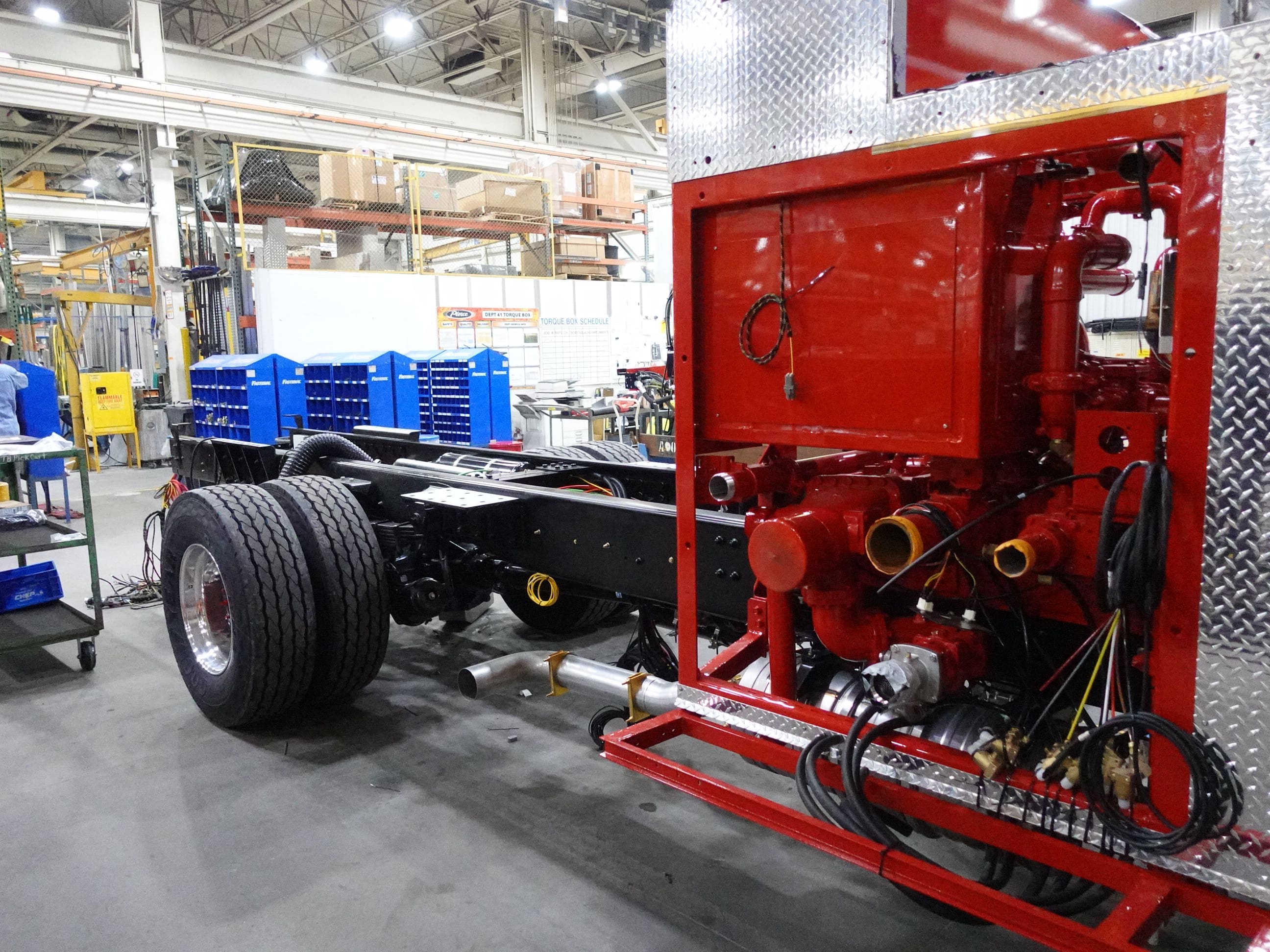

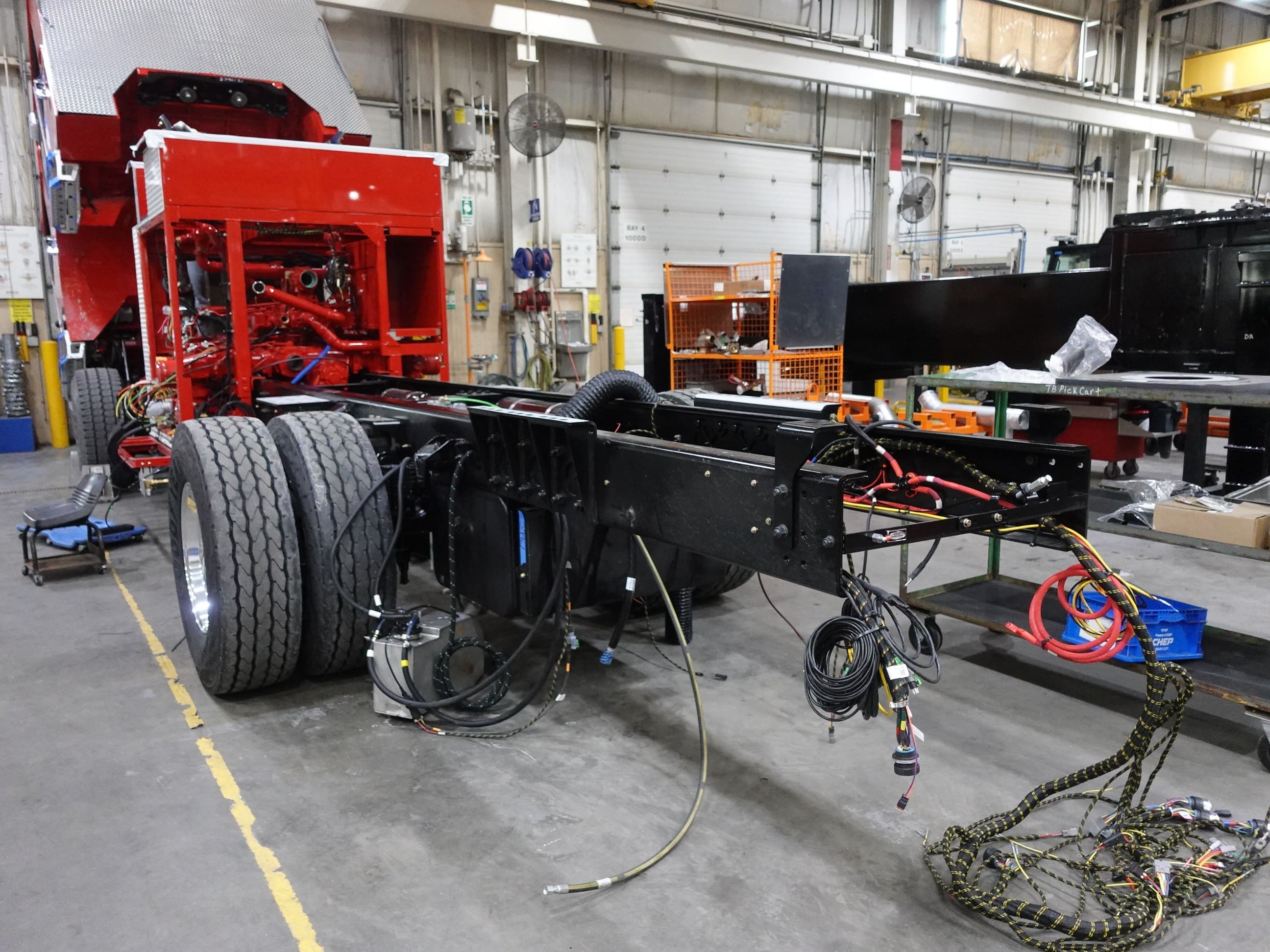

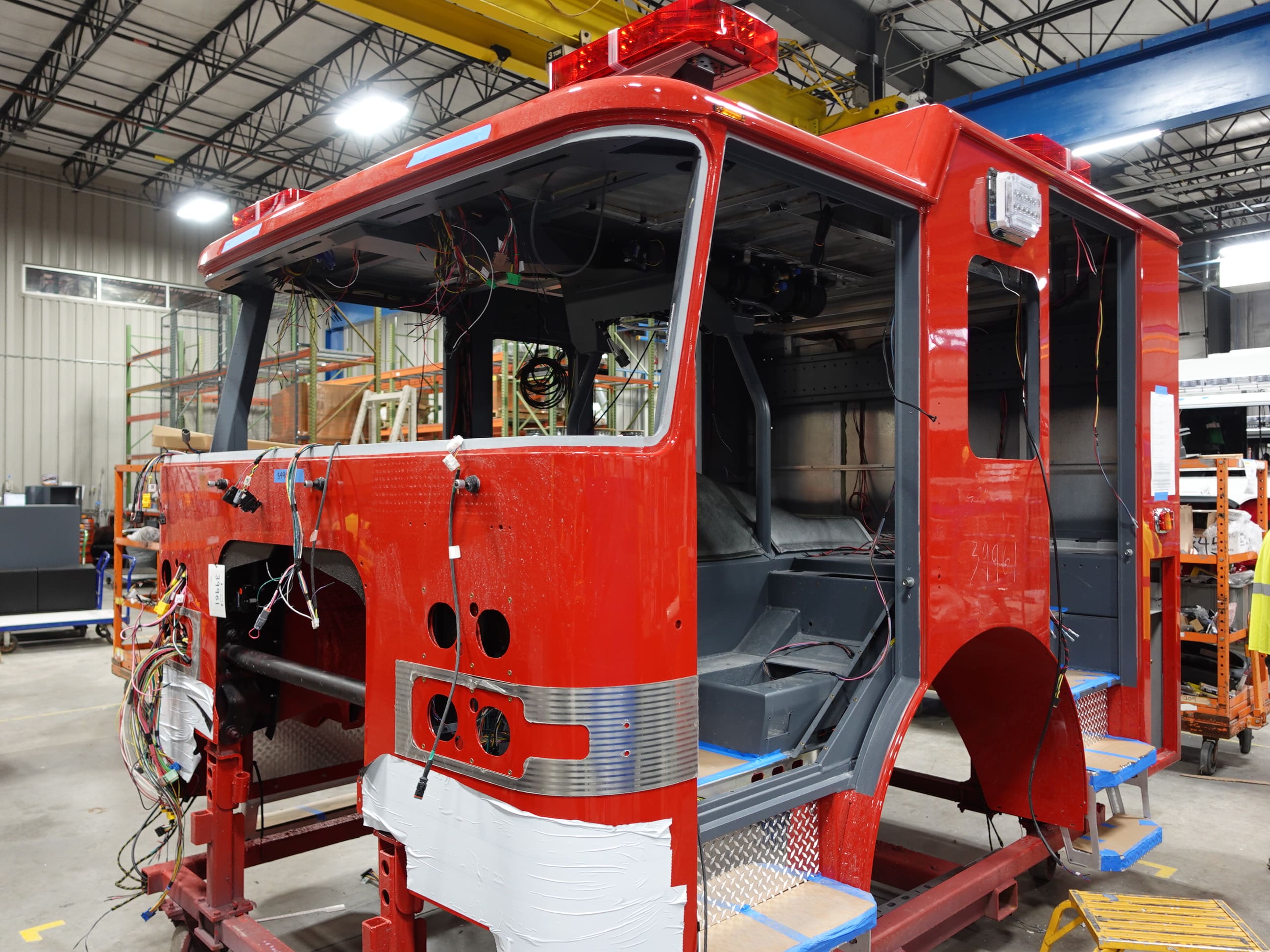

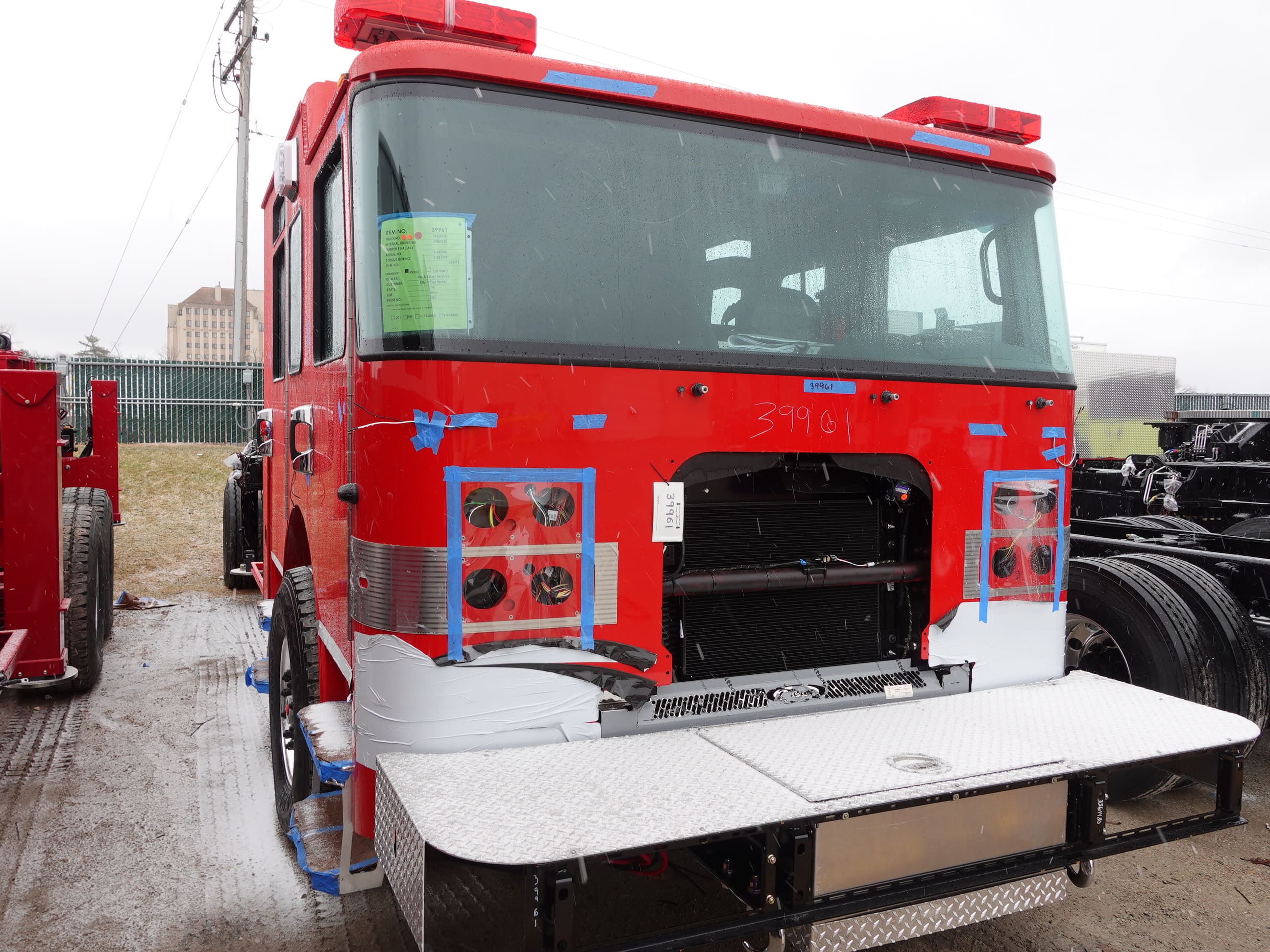

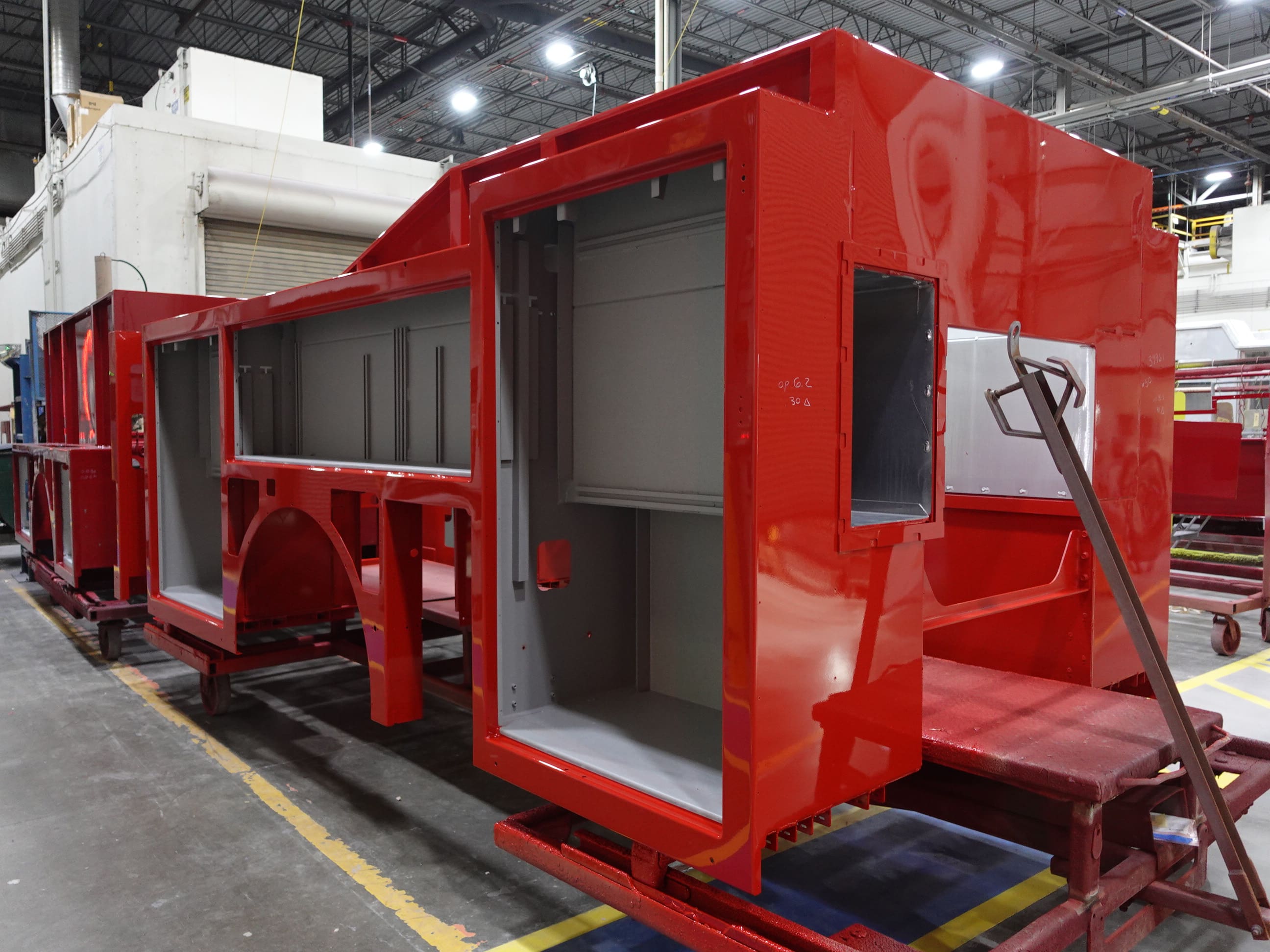

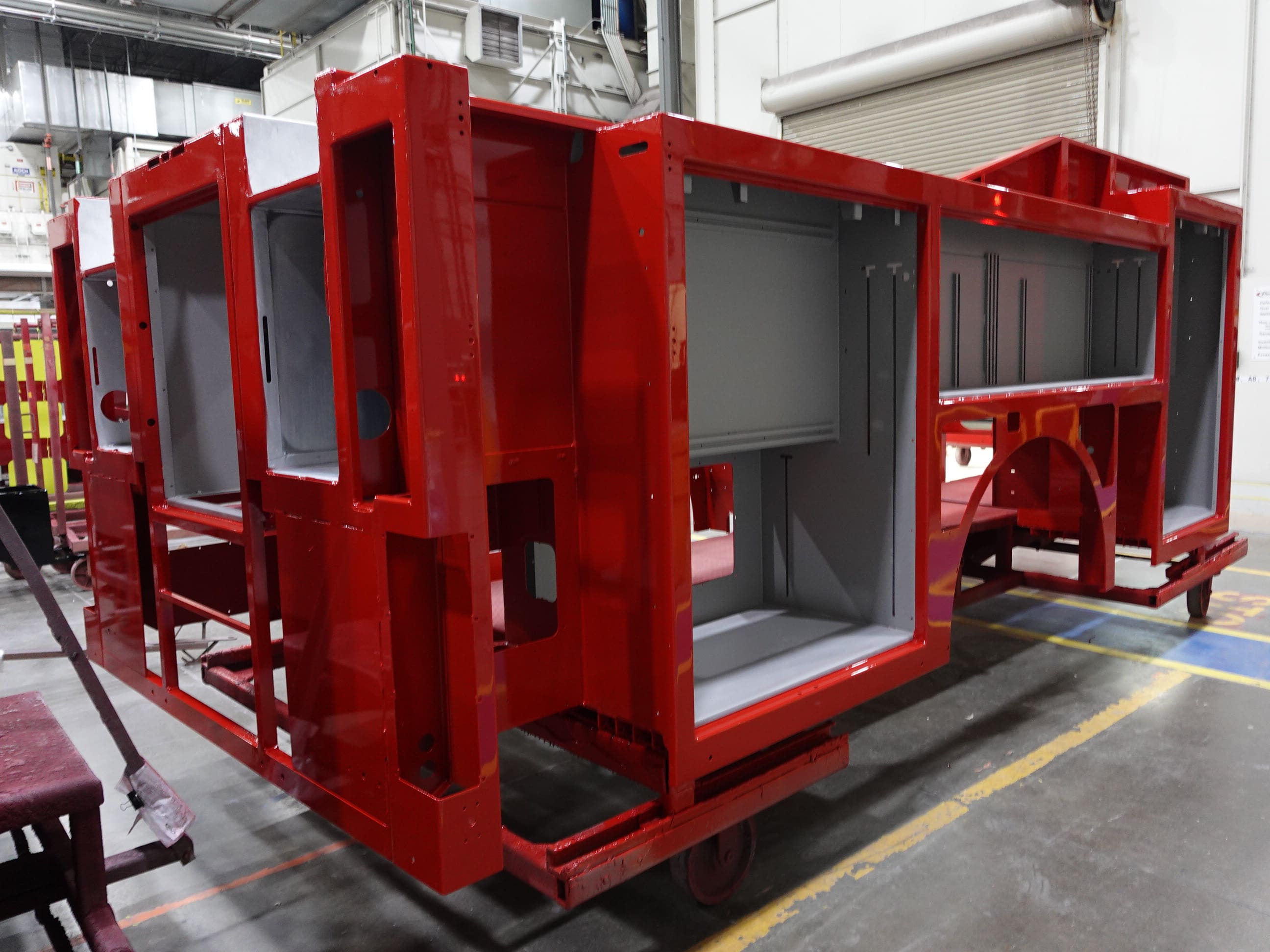

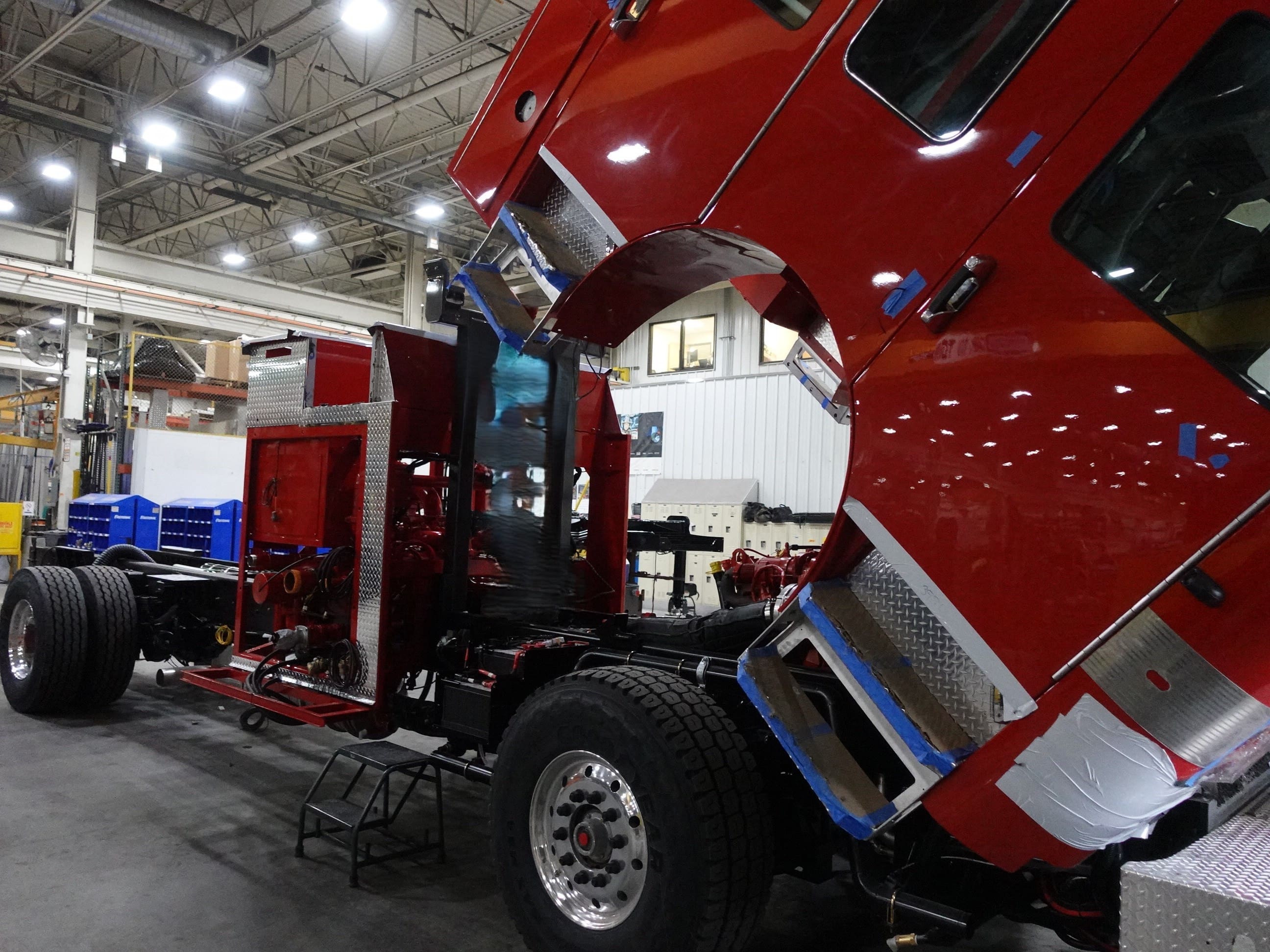

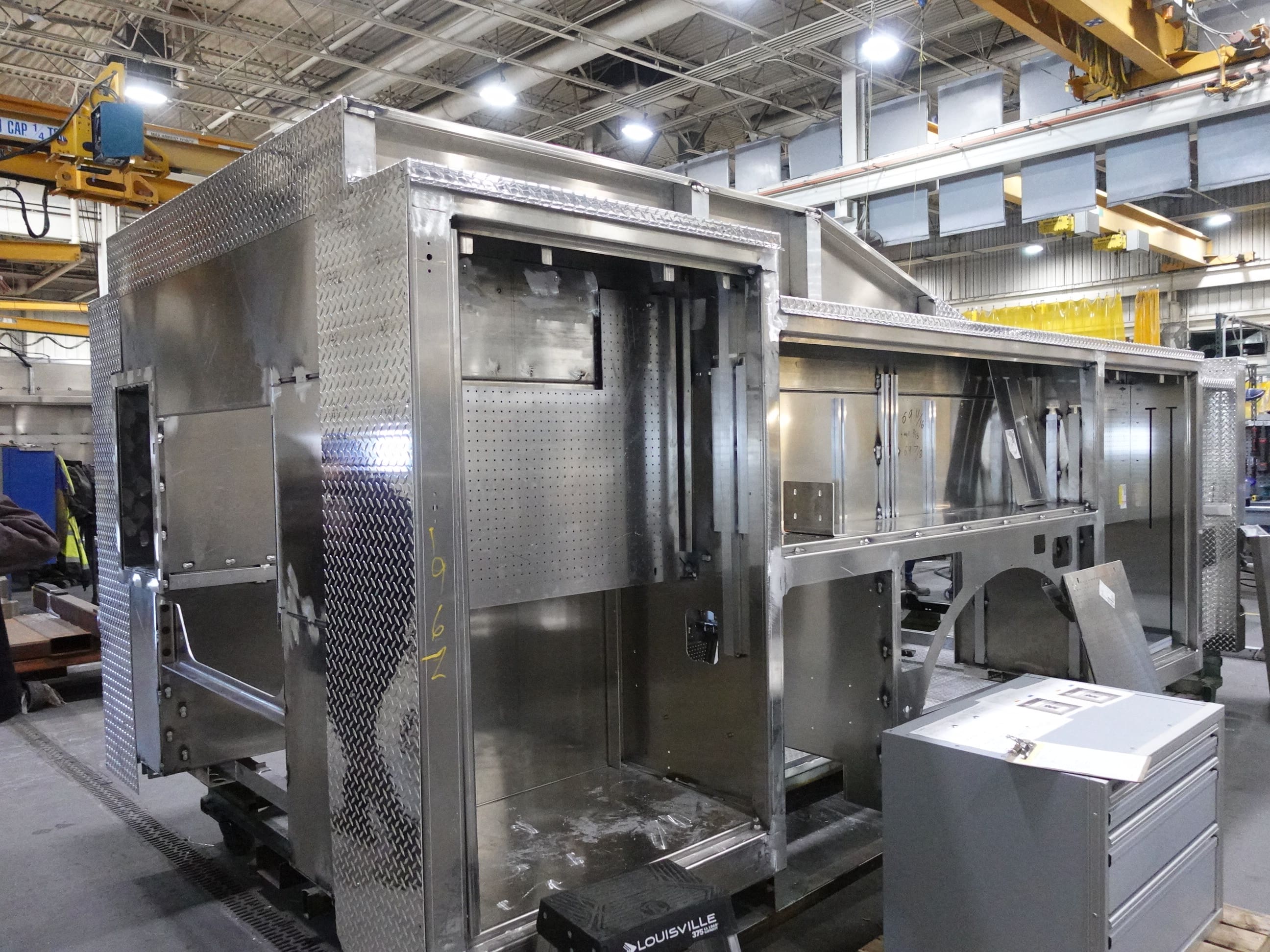

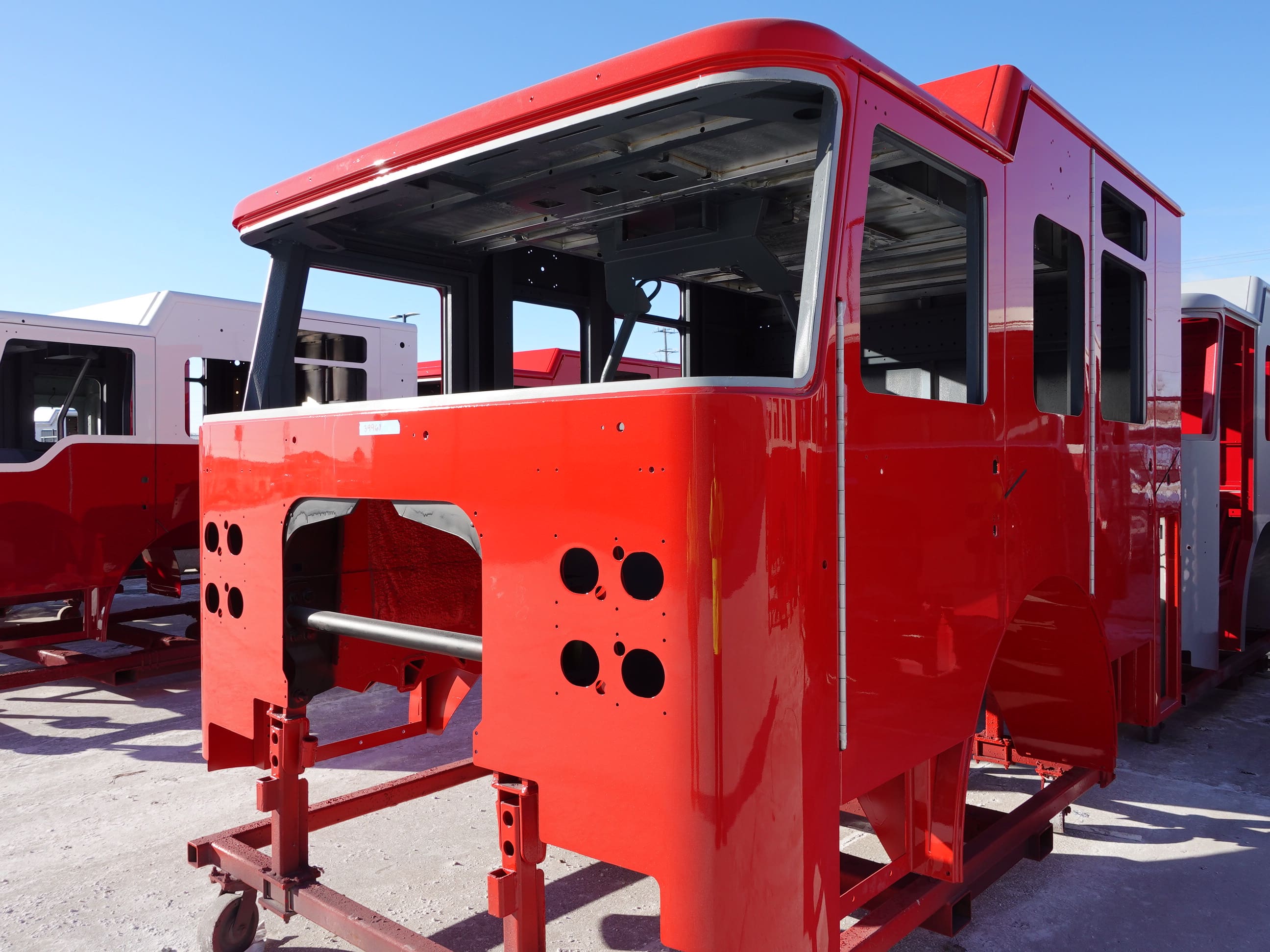

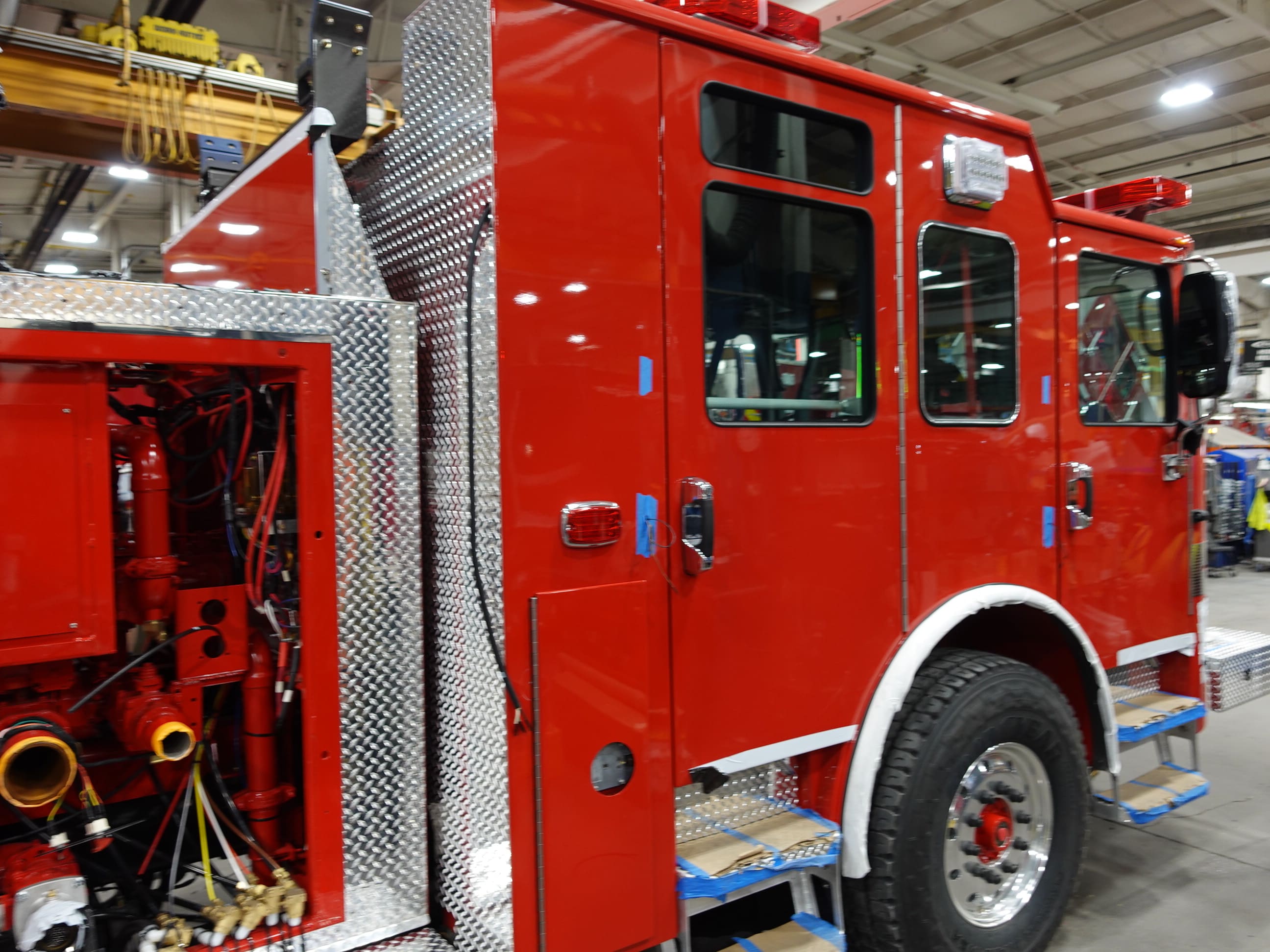

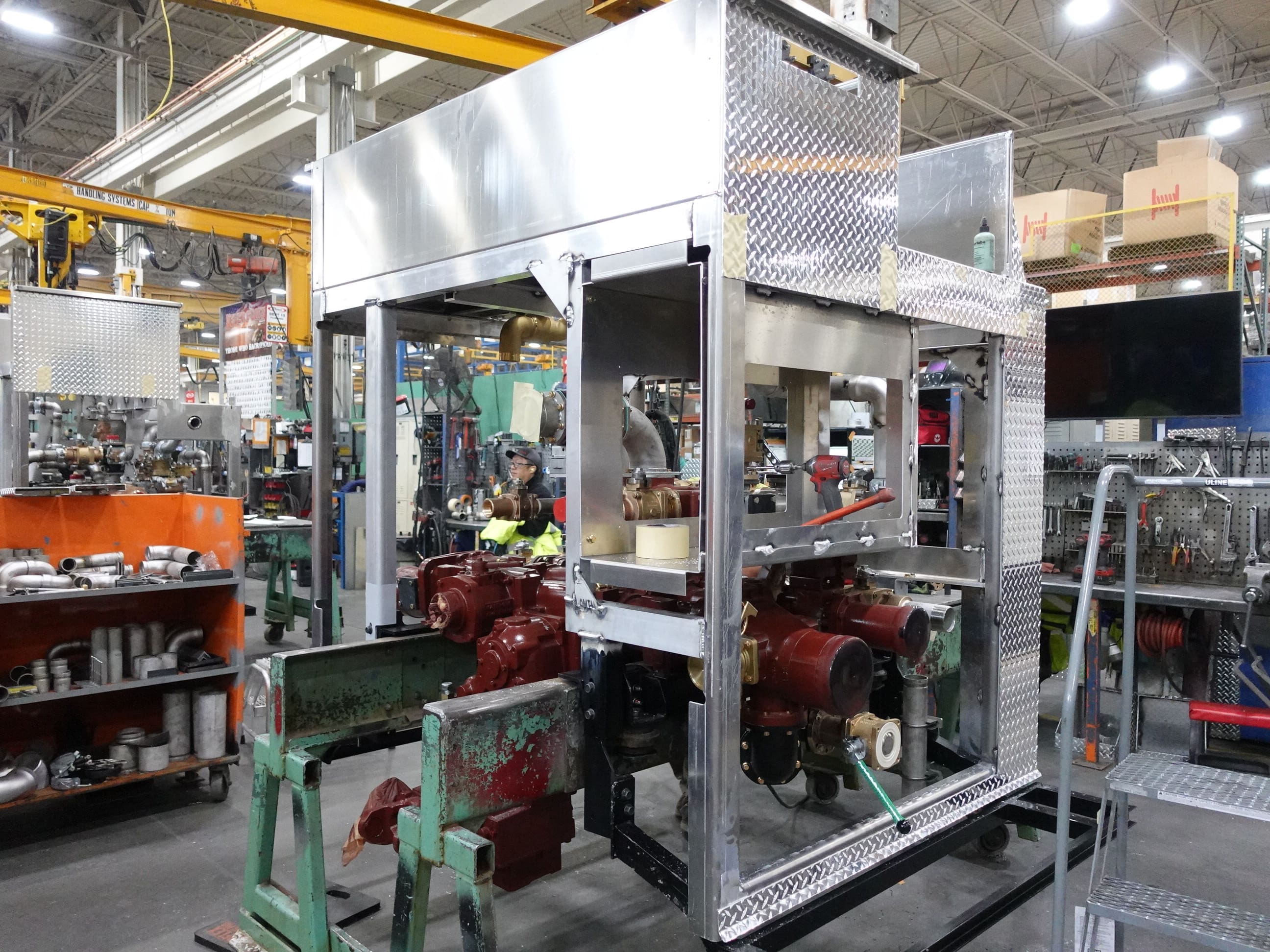

In this report, the apparatus completed final assembly
while the aerial device completed initial assembly.

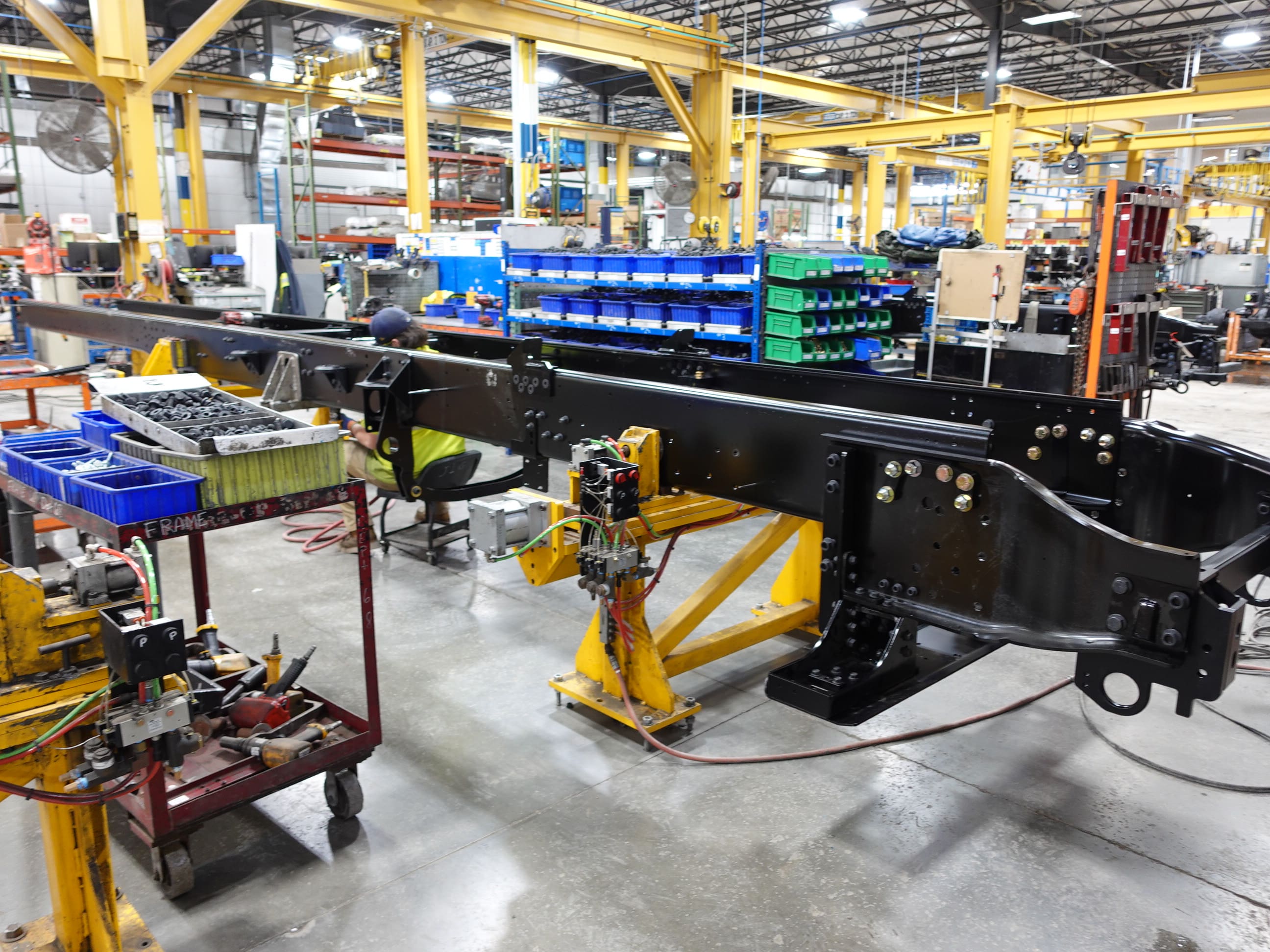

03-20-26

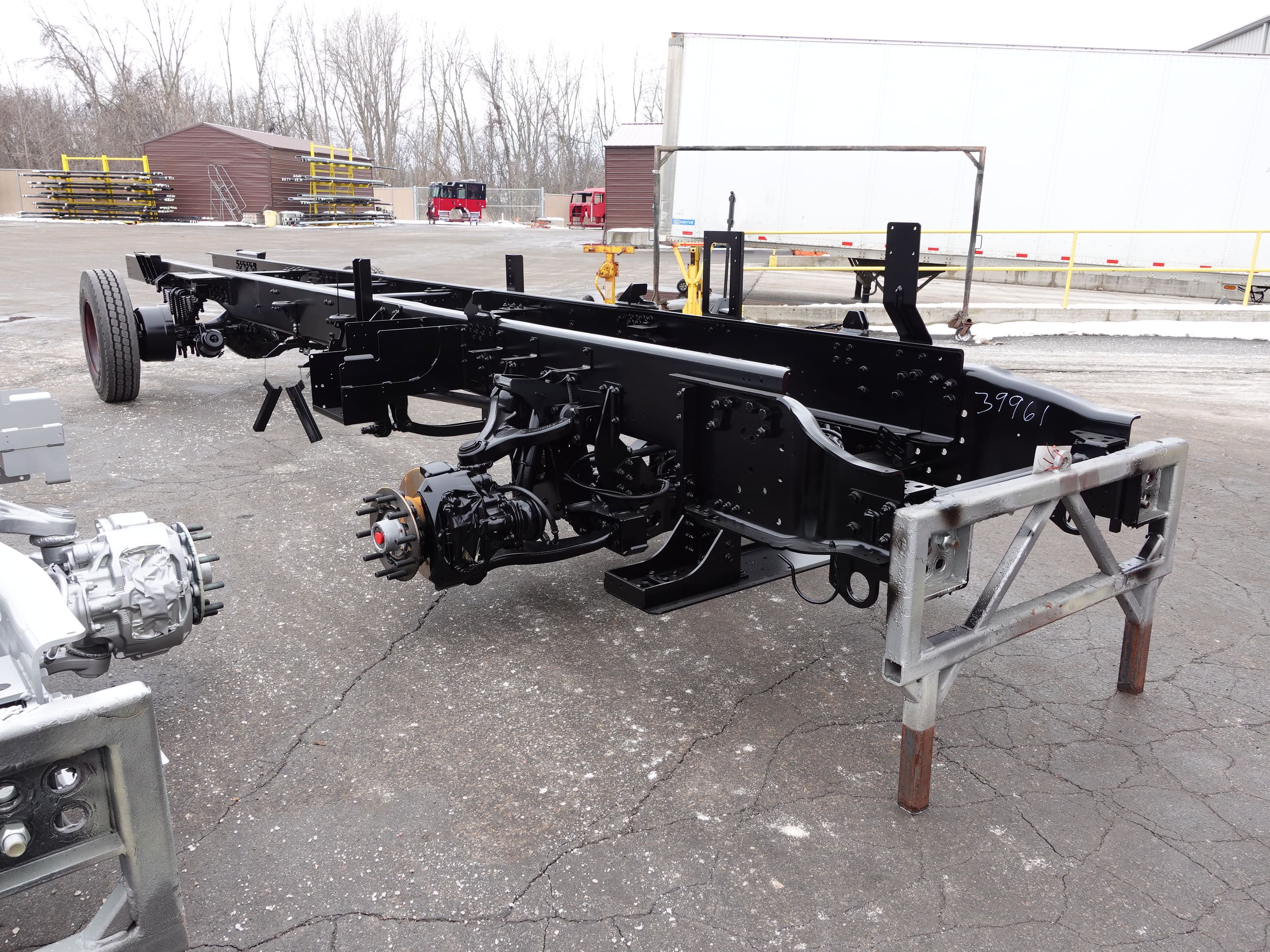

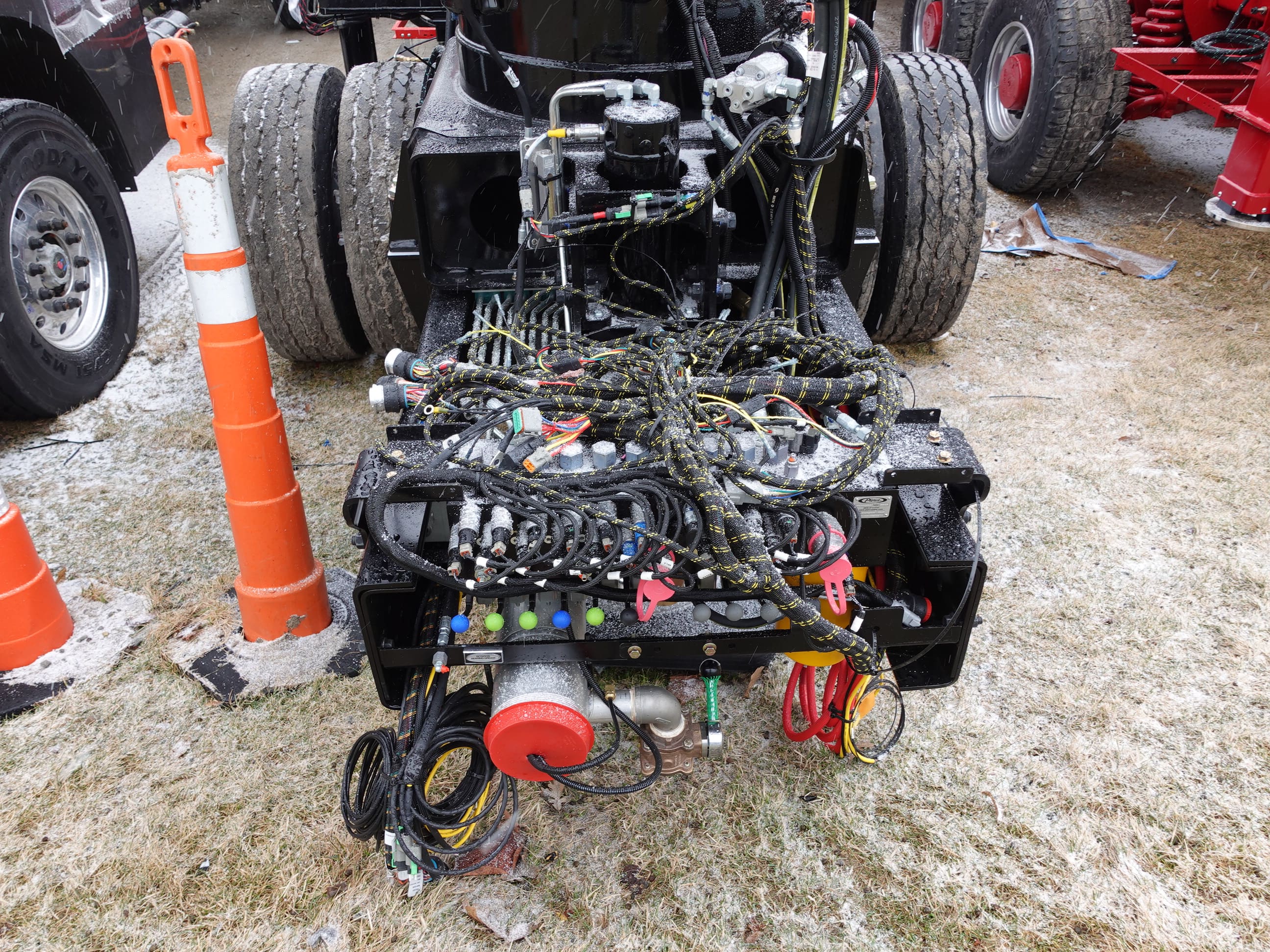

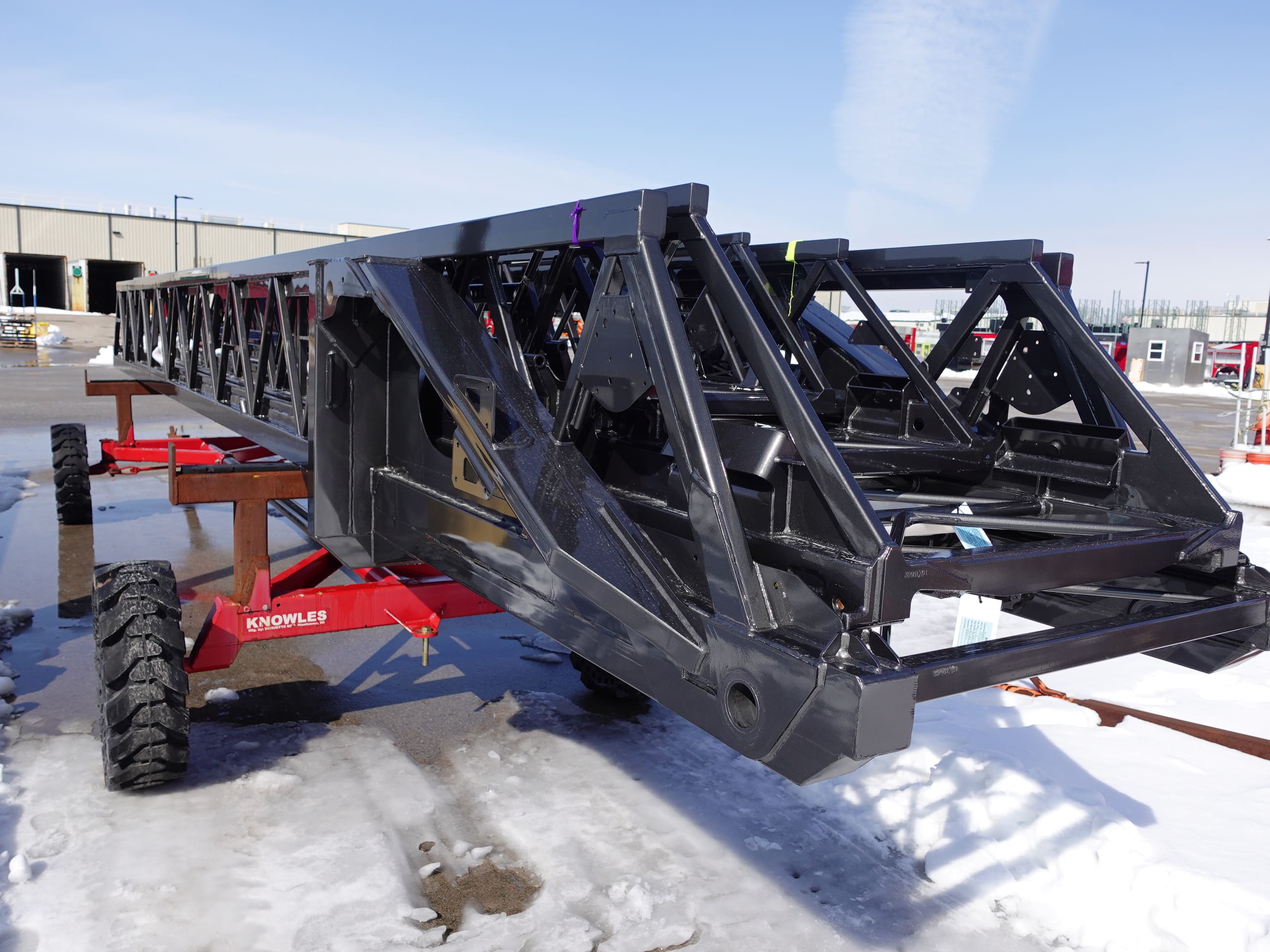

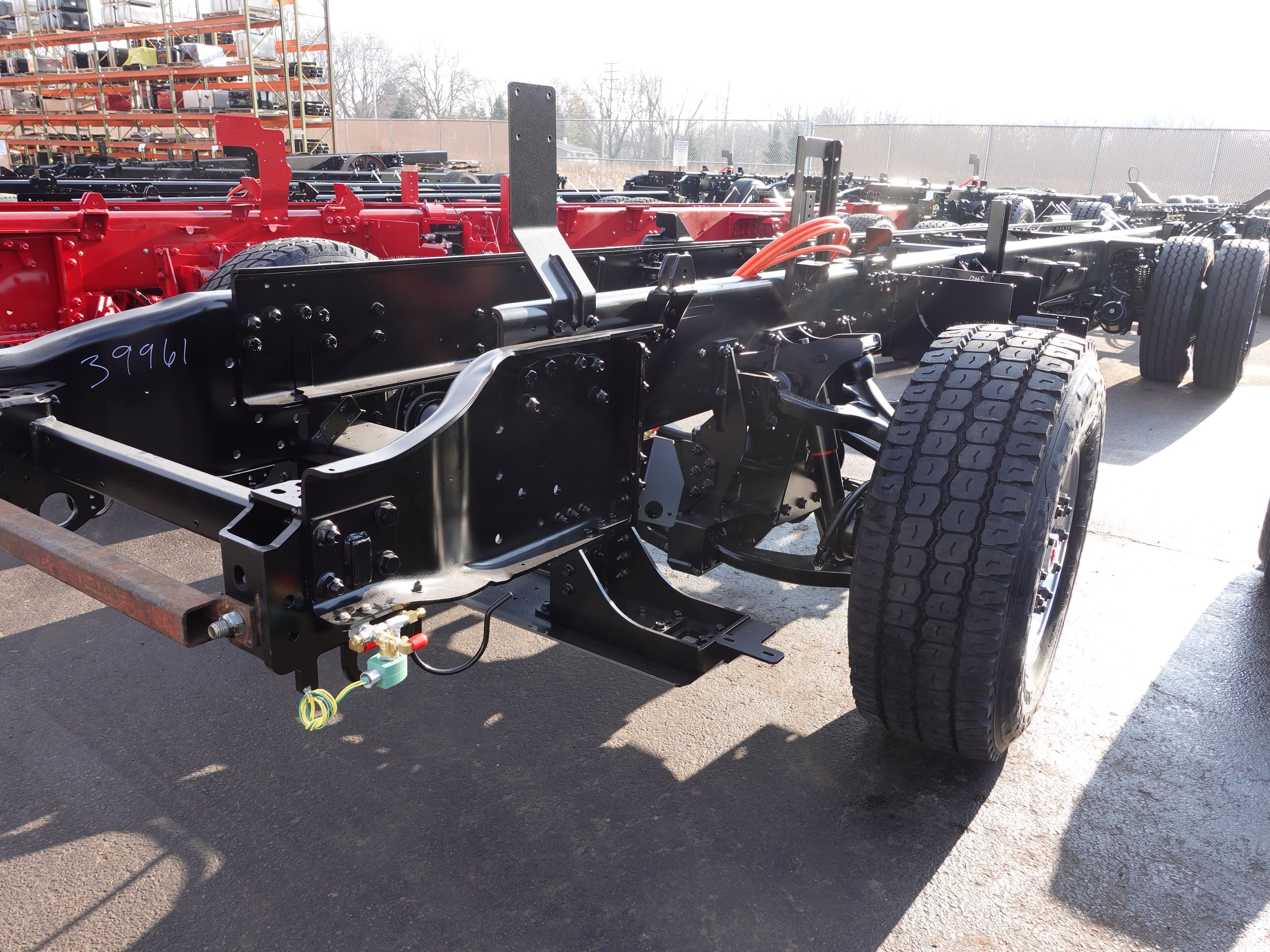

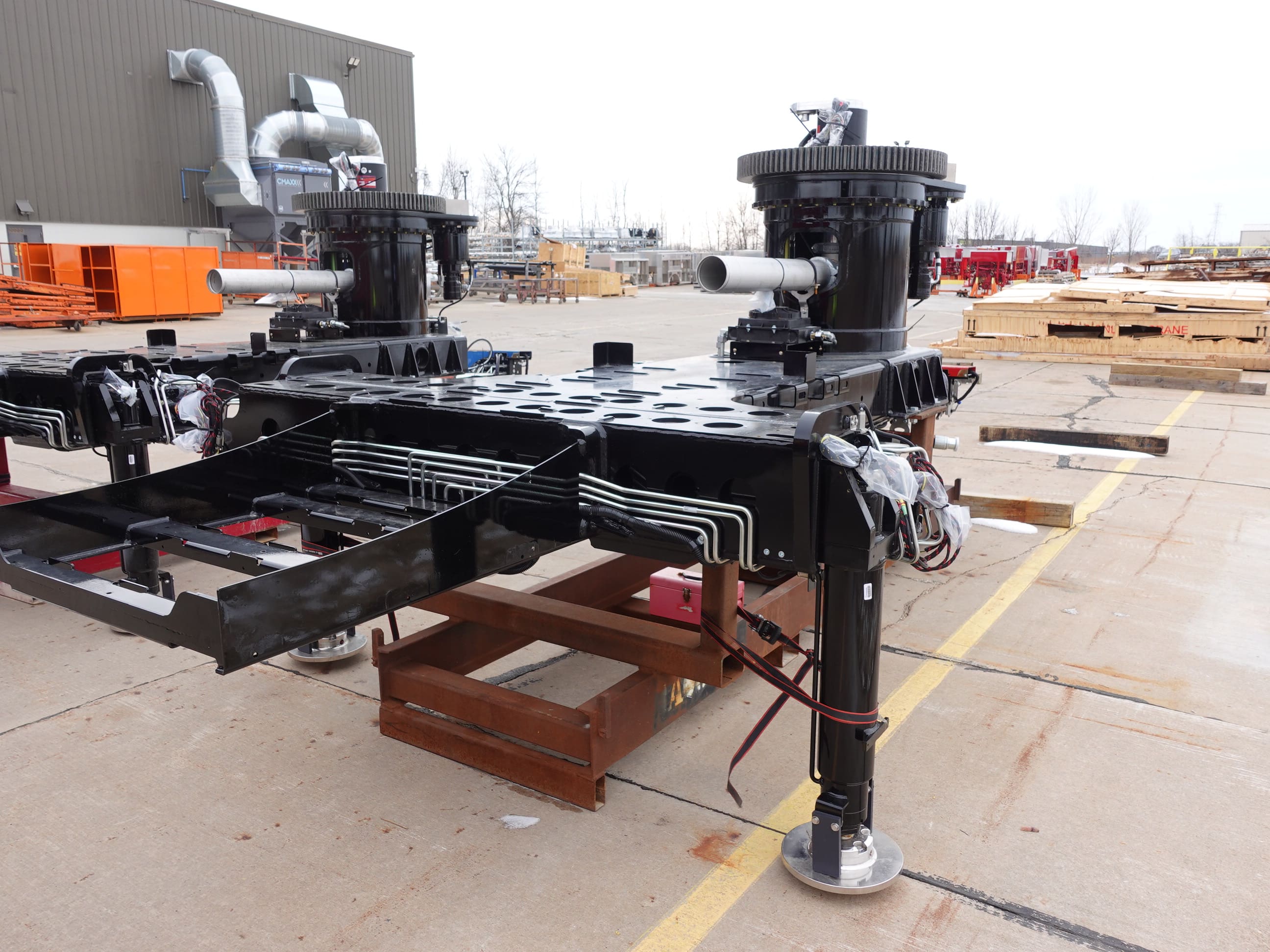

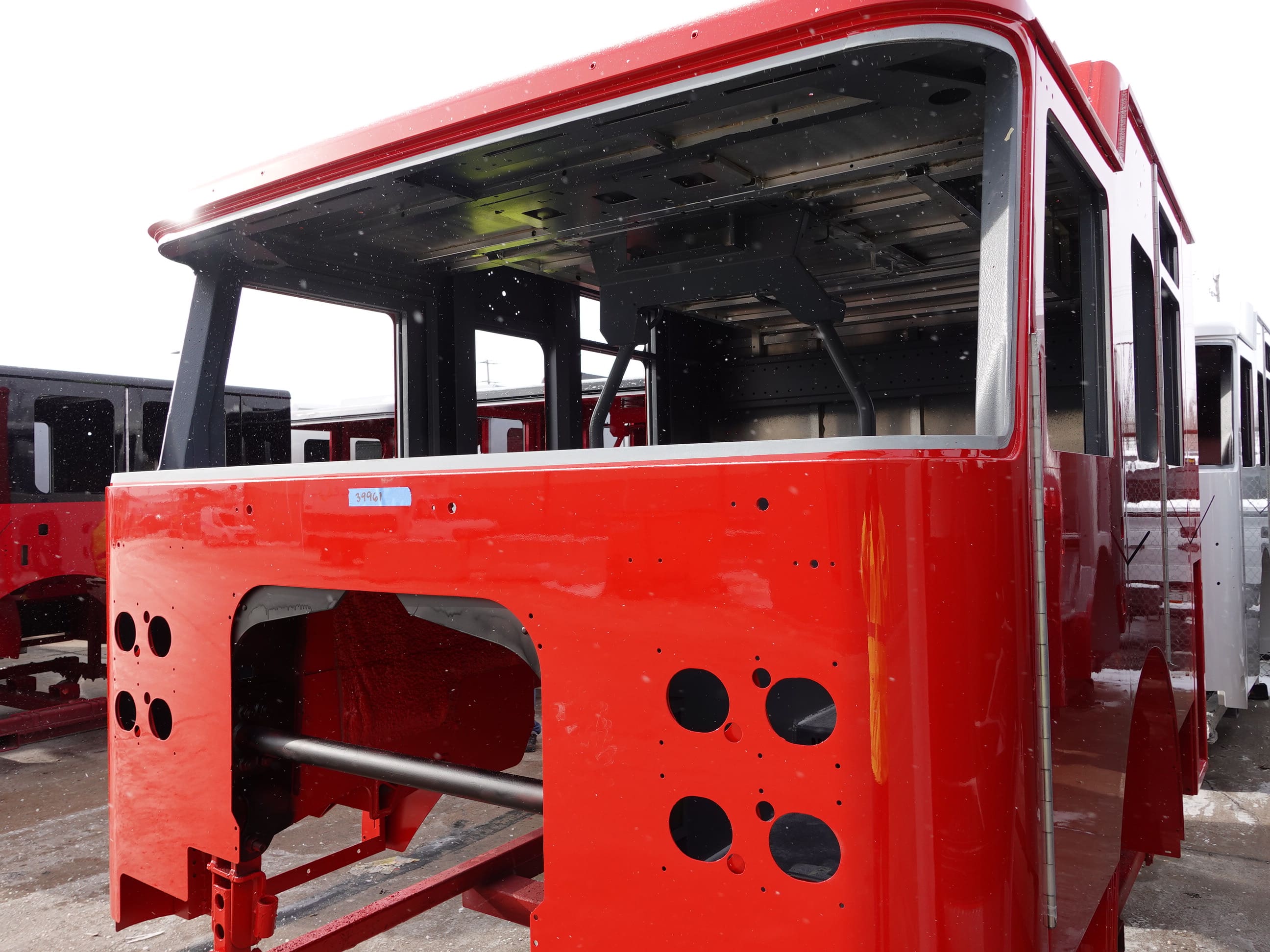

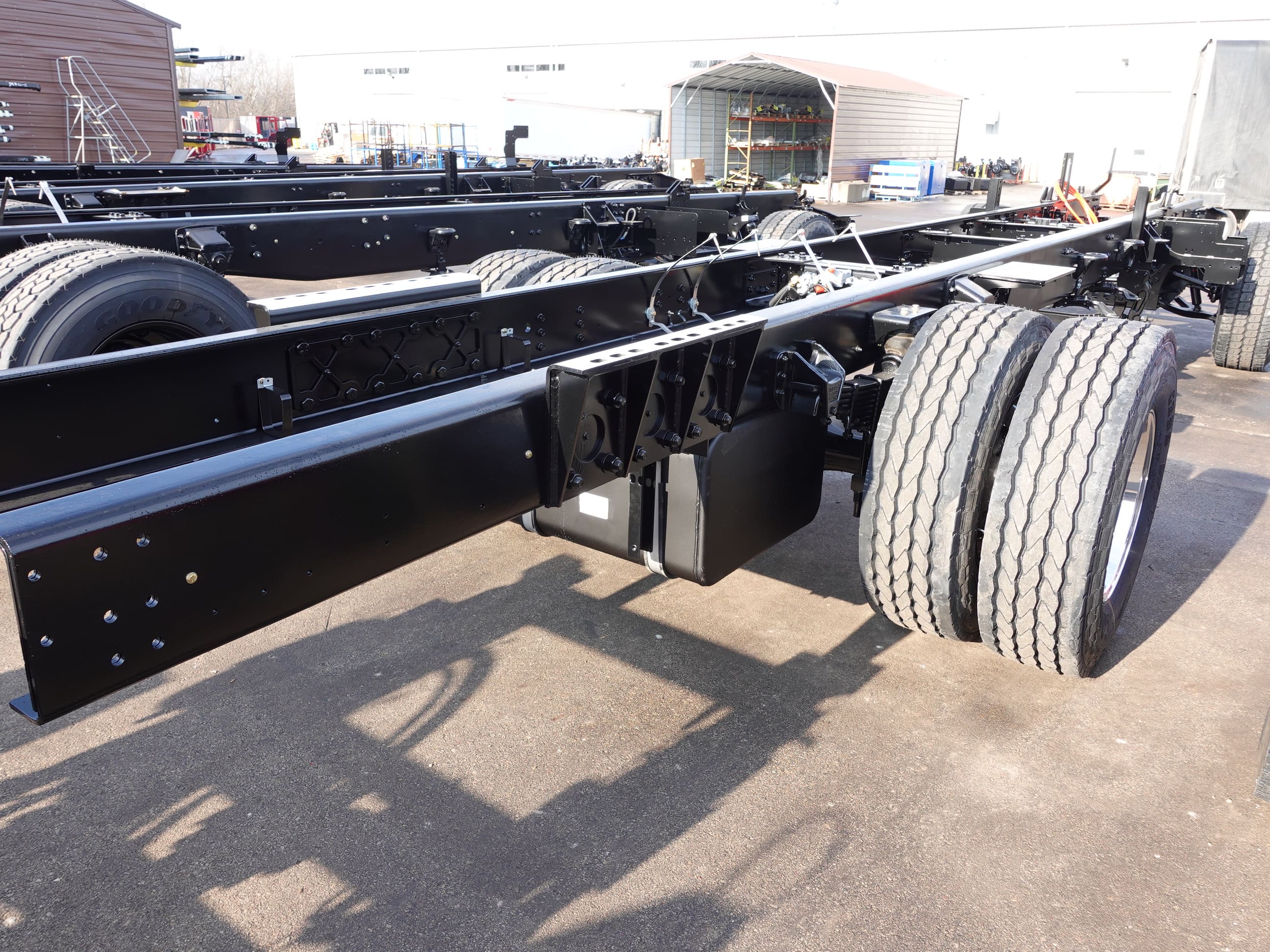

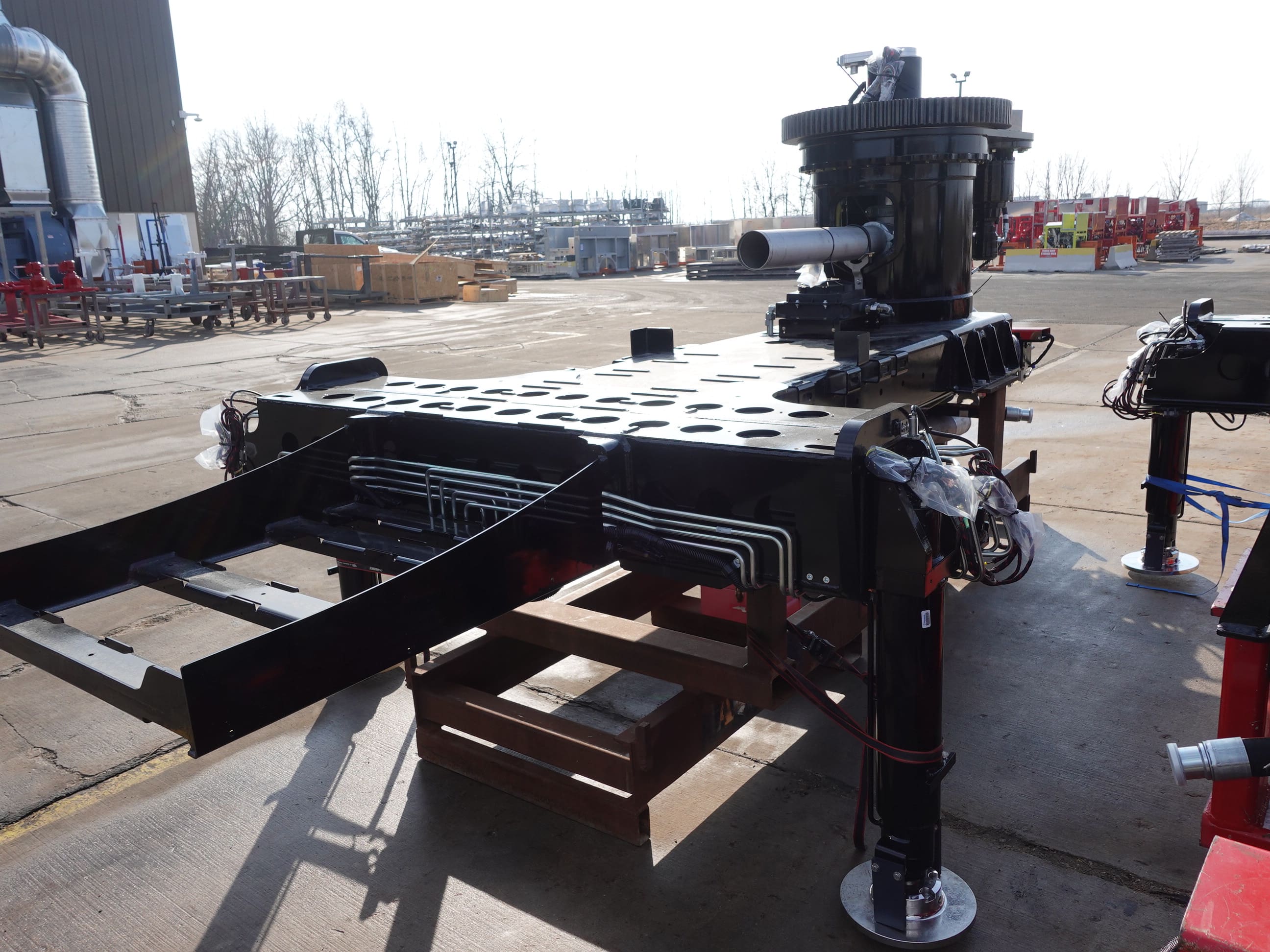

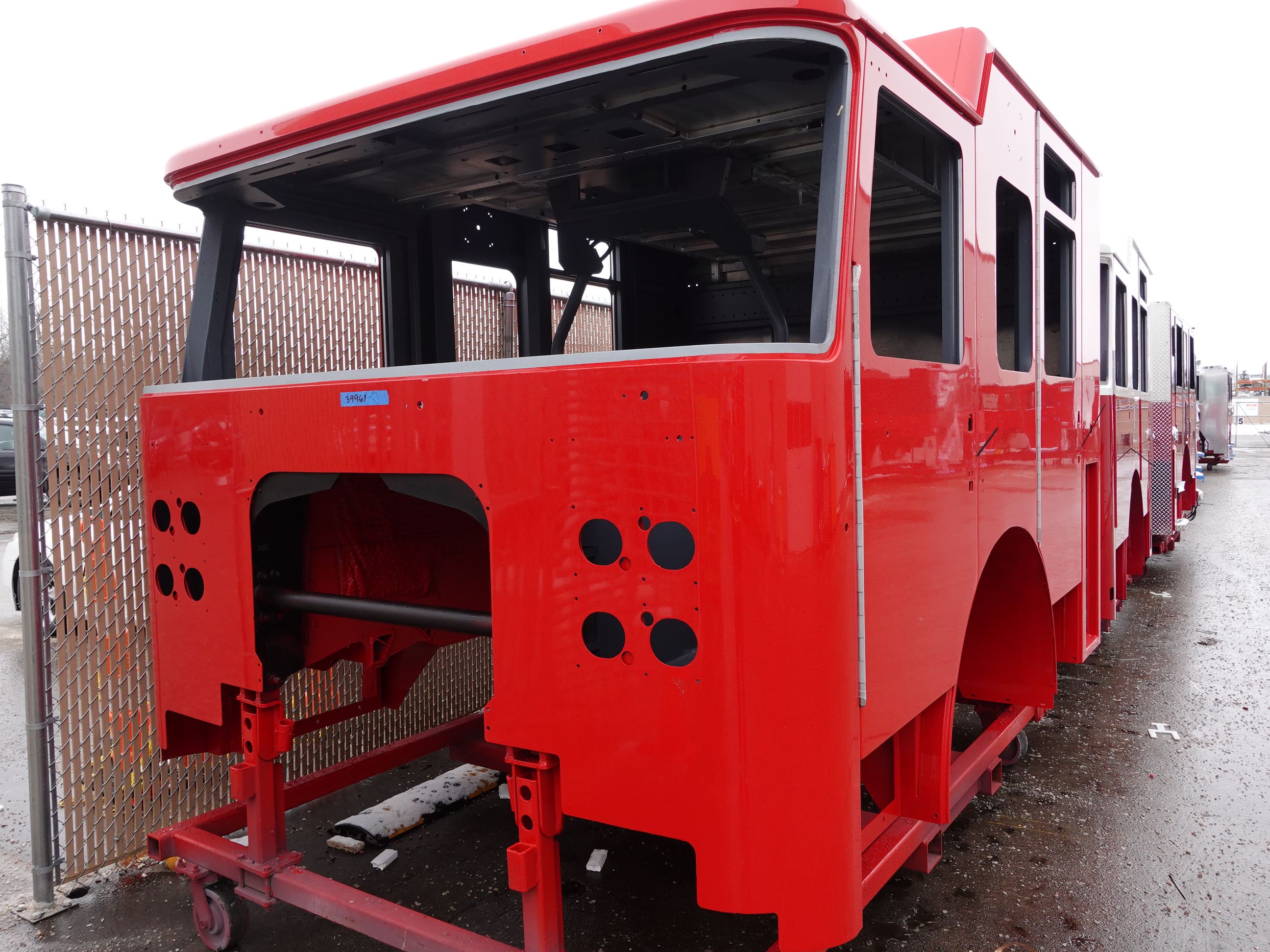

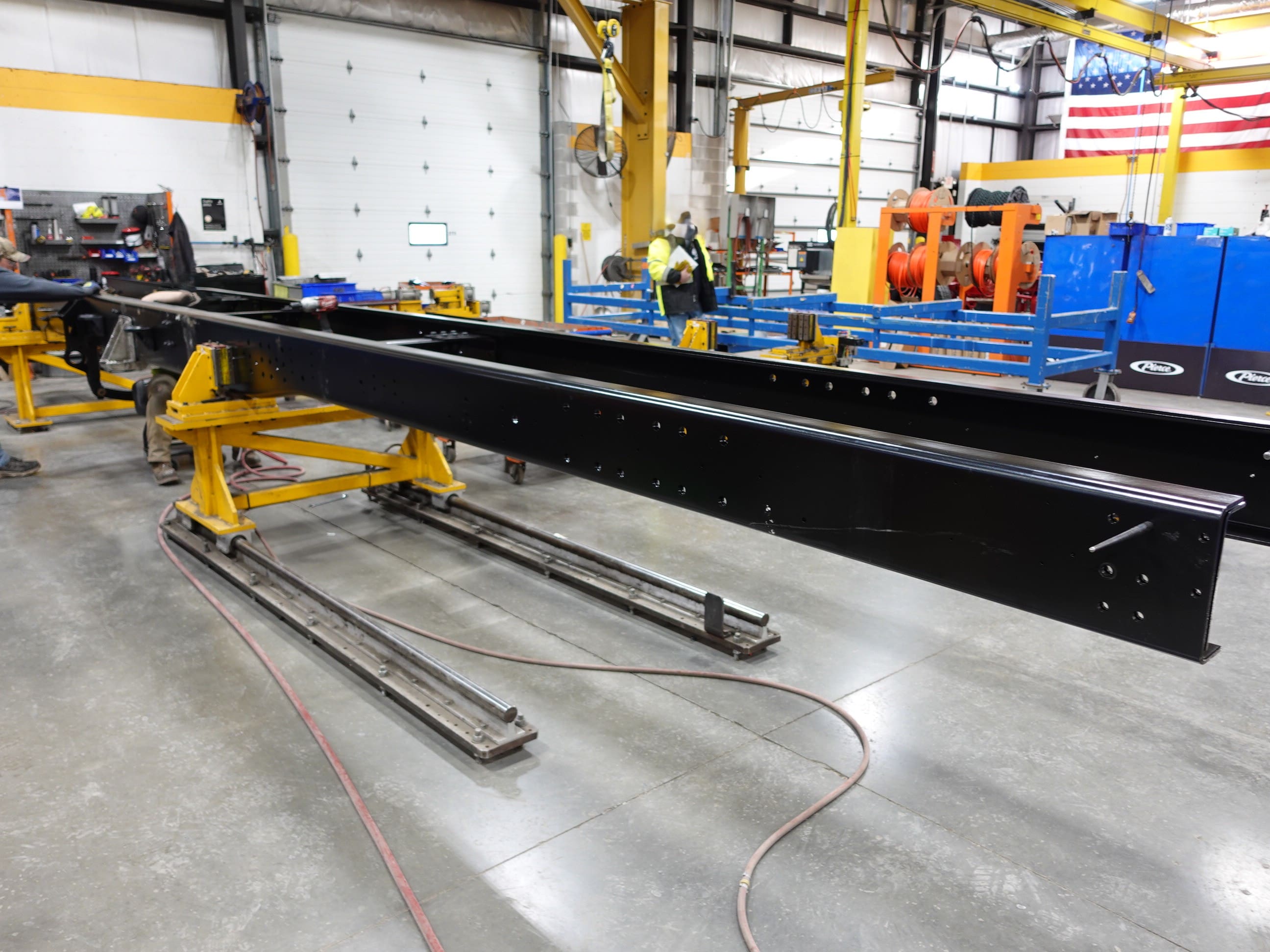

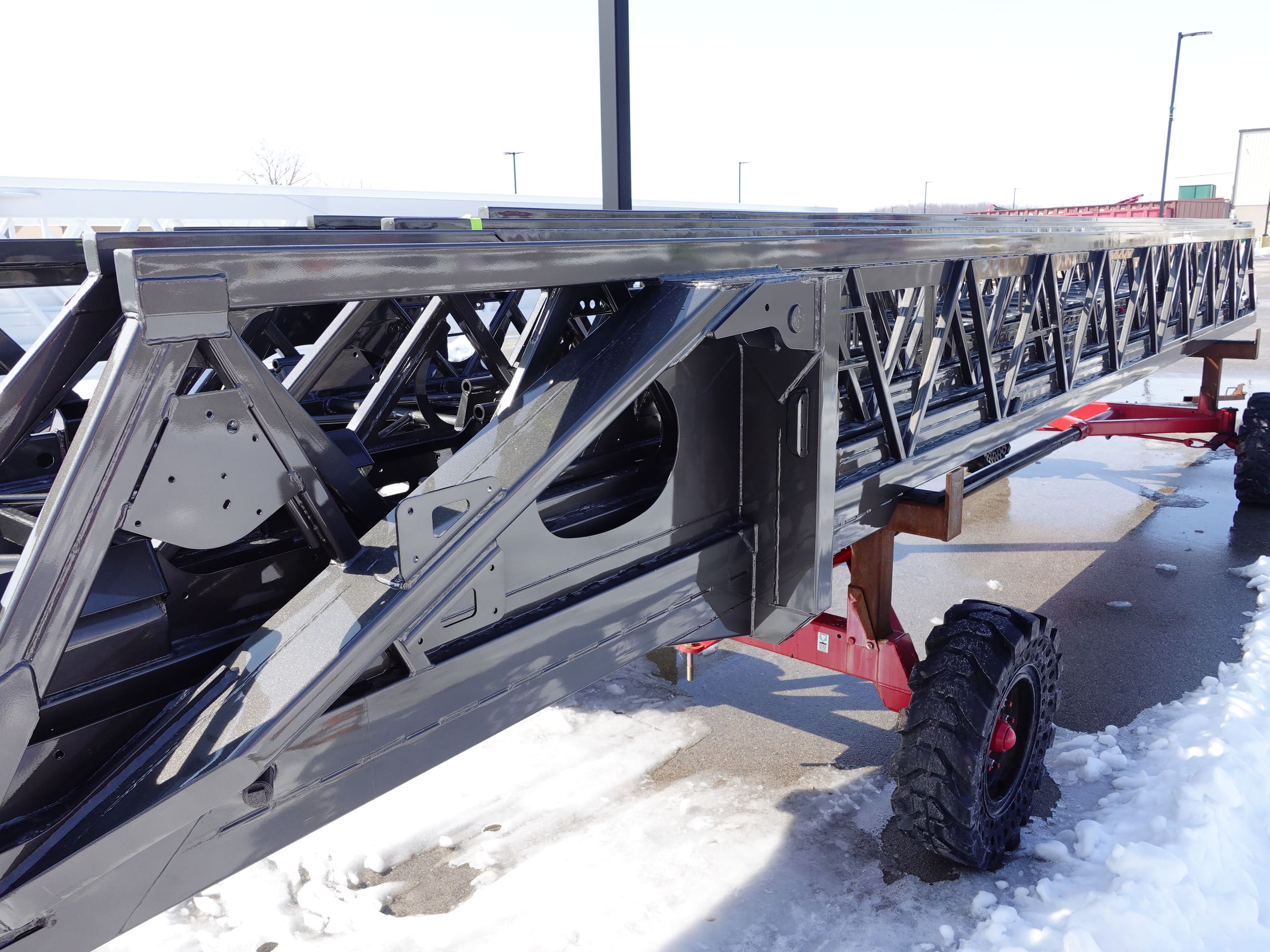

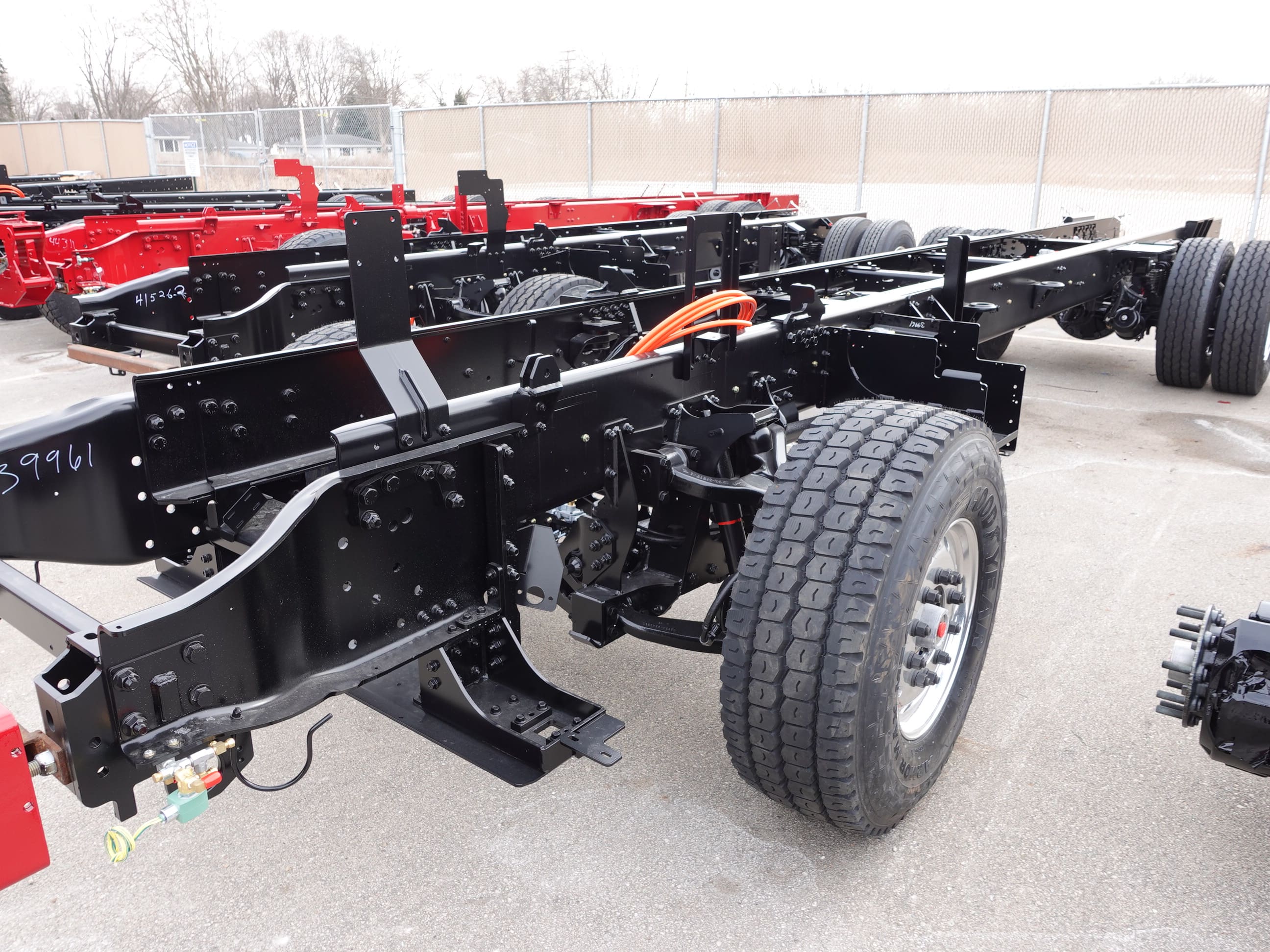

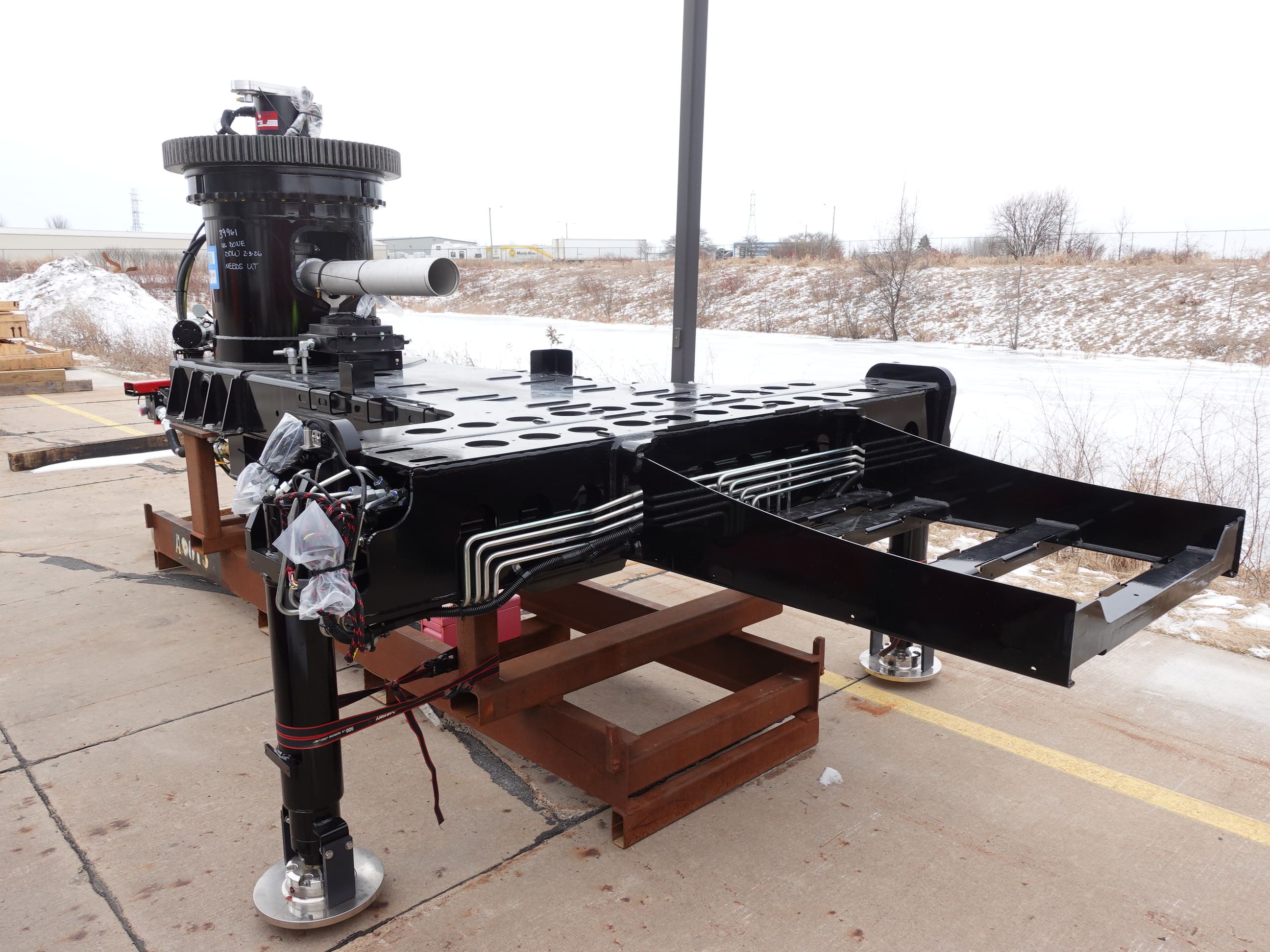

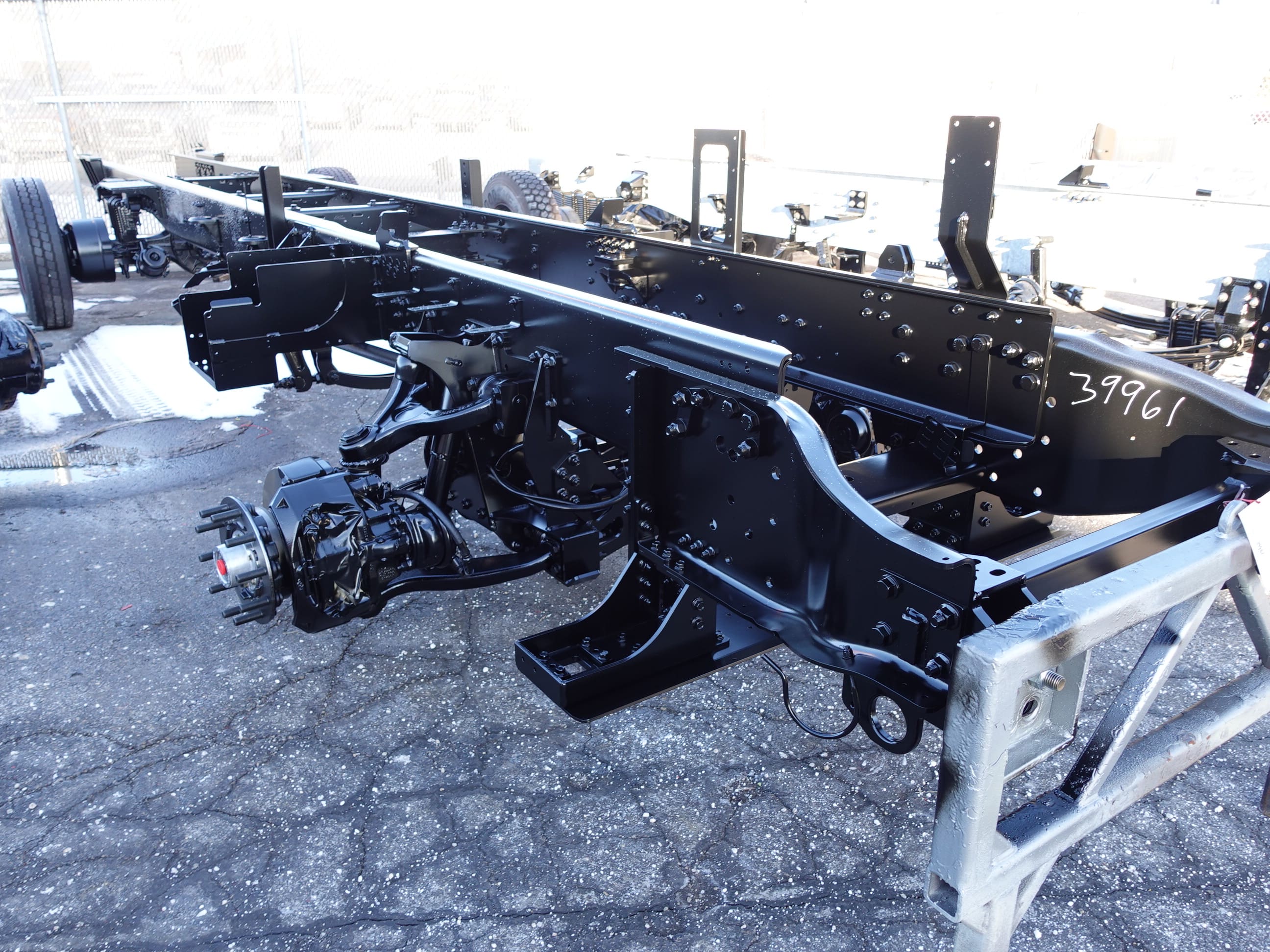

In this report, the body was merged with the chassis at the start of initial apparatus assembly while the aerial device arrived.
03-13-26
In this report, the pedestal was merged with the chassis while the body remained staged.
03-06-26

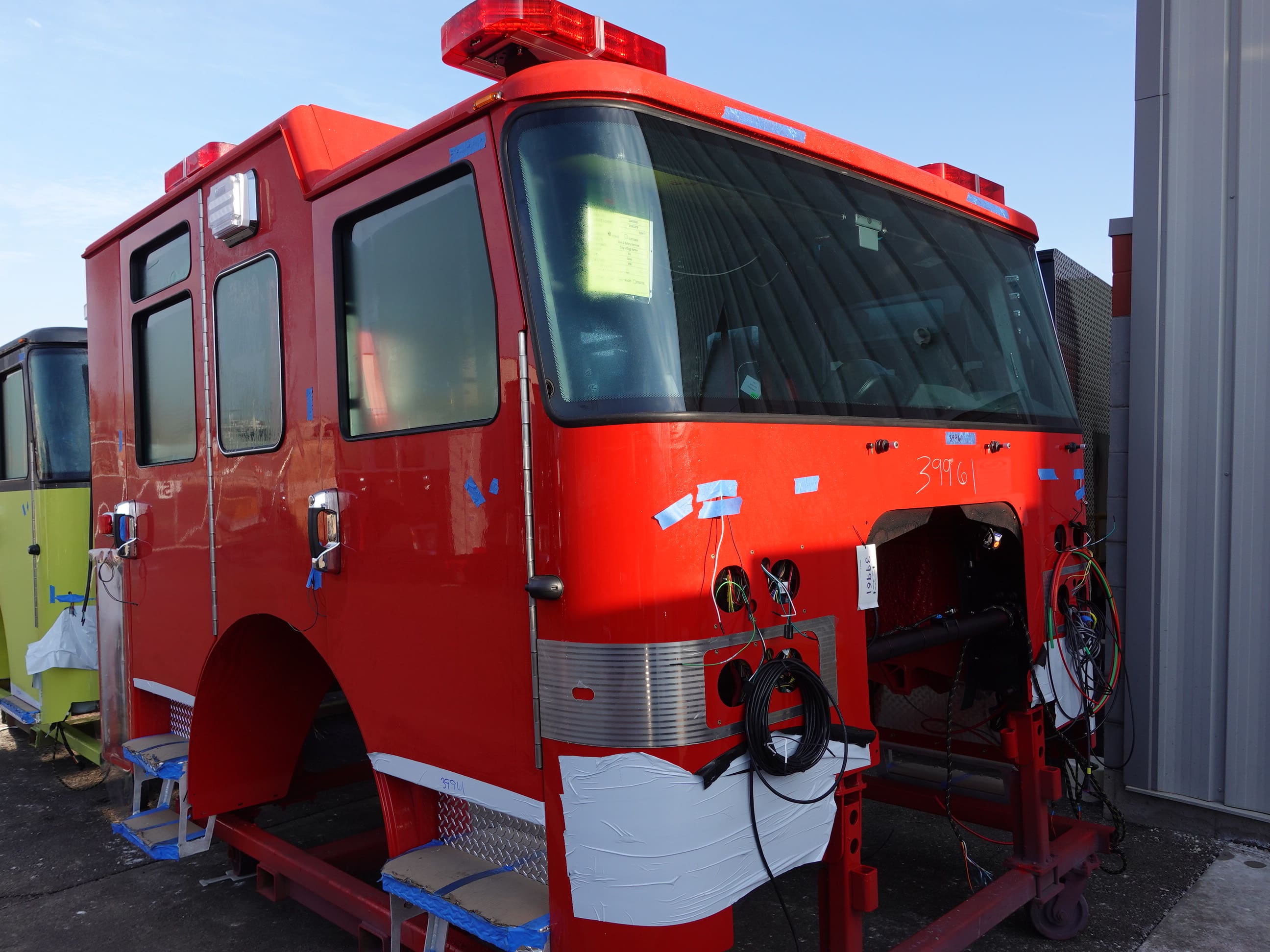

In this report, the cab and pump house were merged with the frame, the pedestal began initial assembly, and the body completed initial assembly.
02-27-26

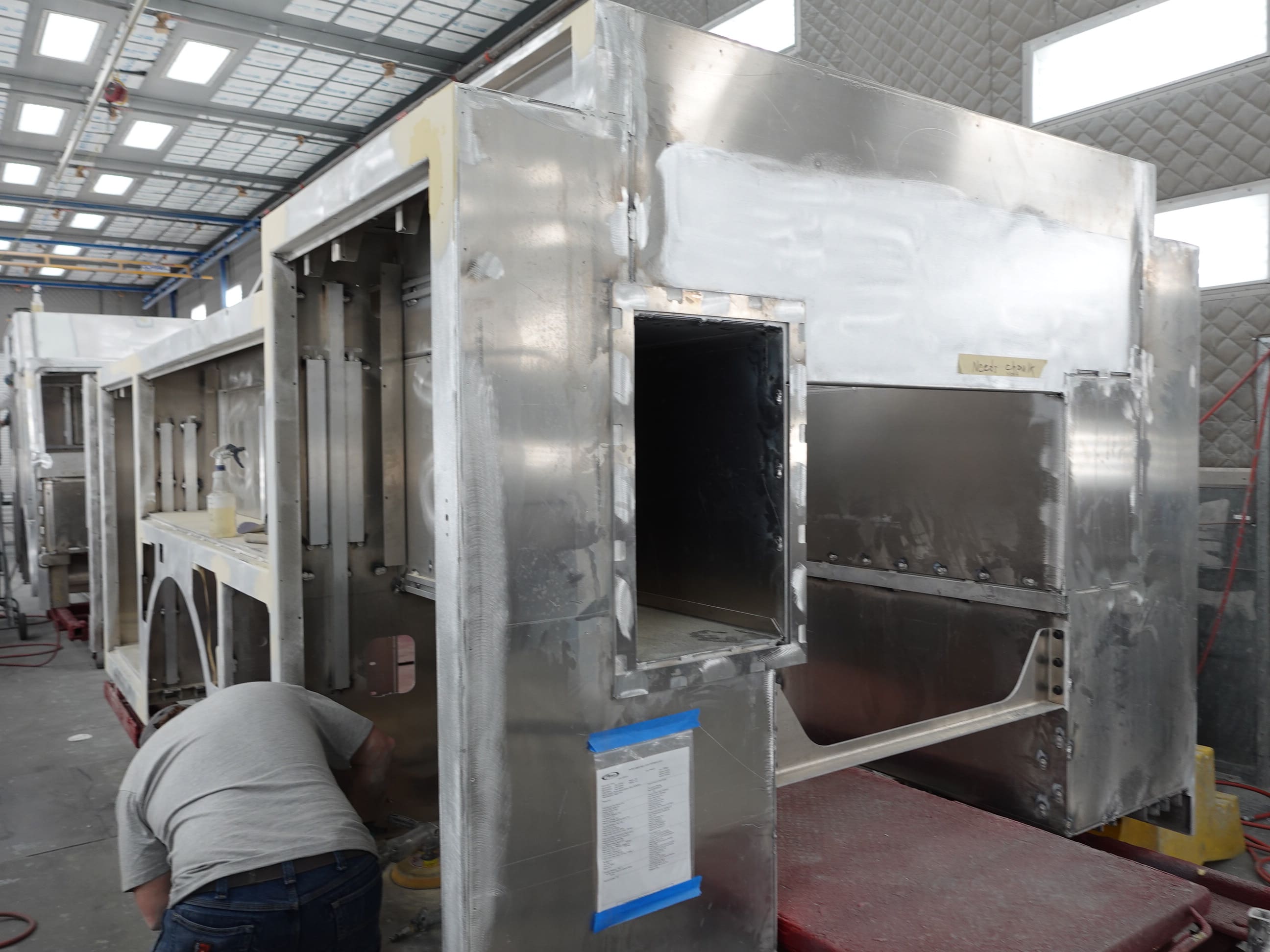

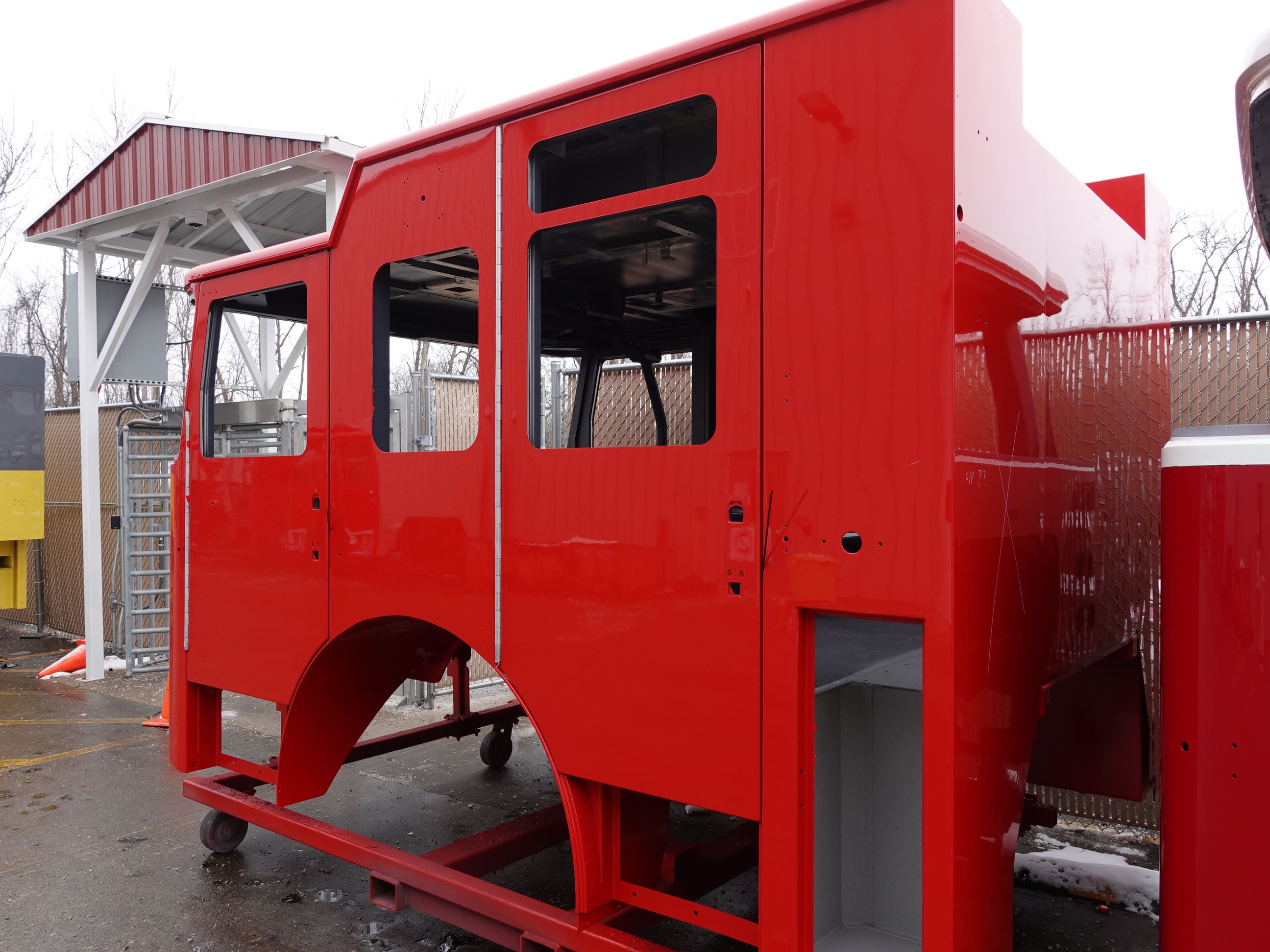

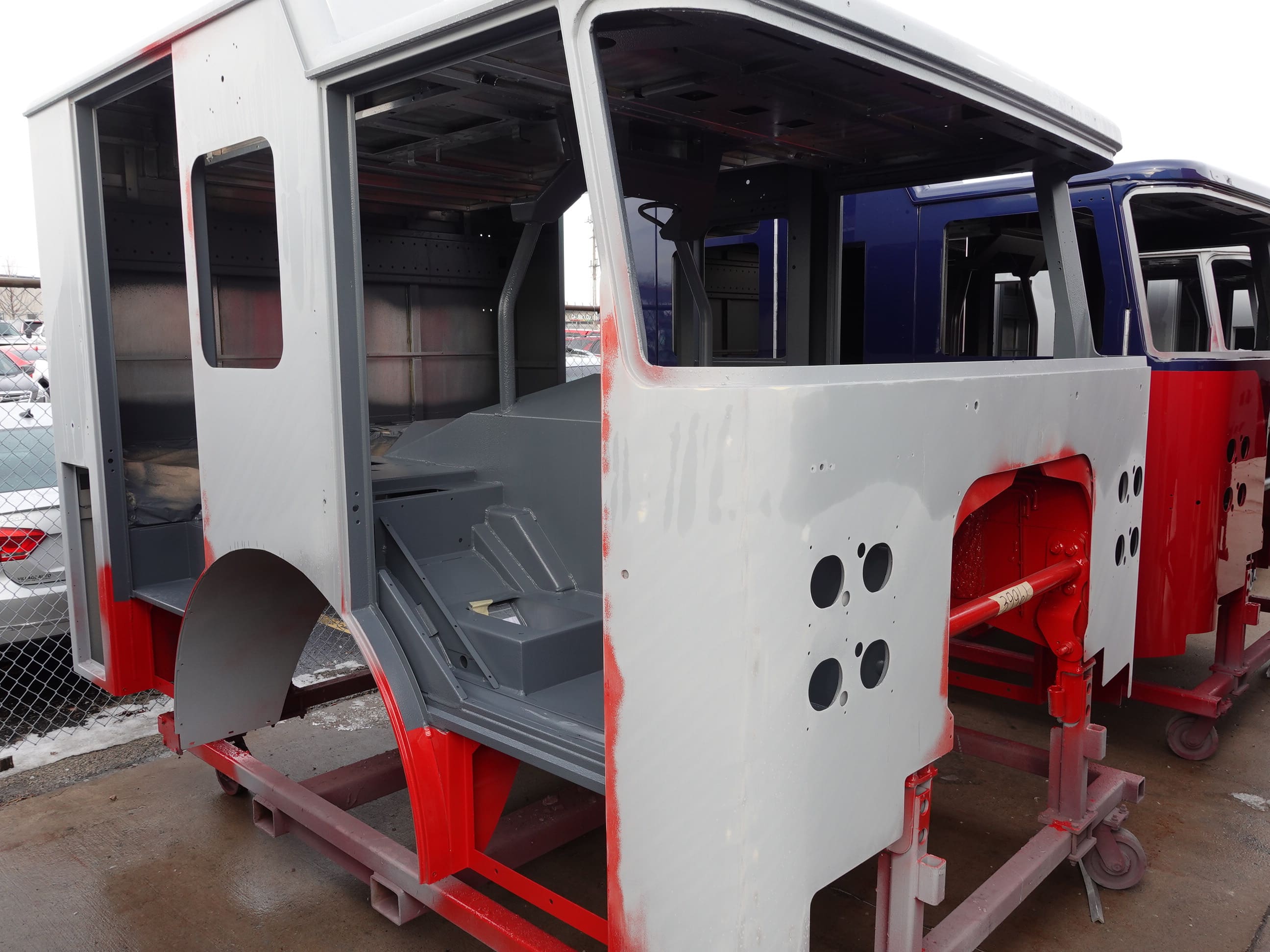

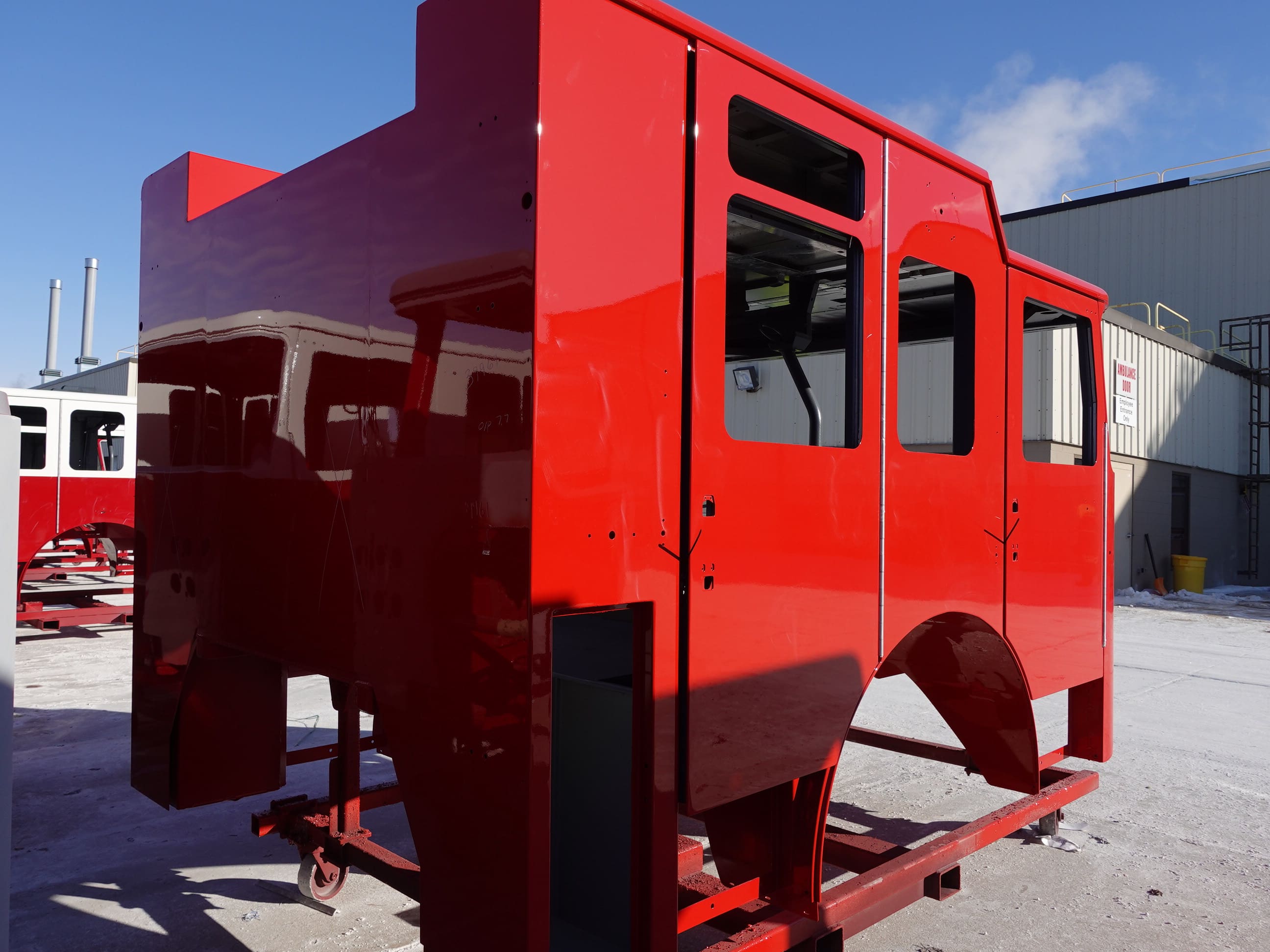

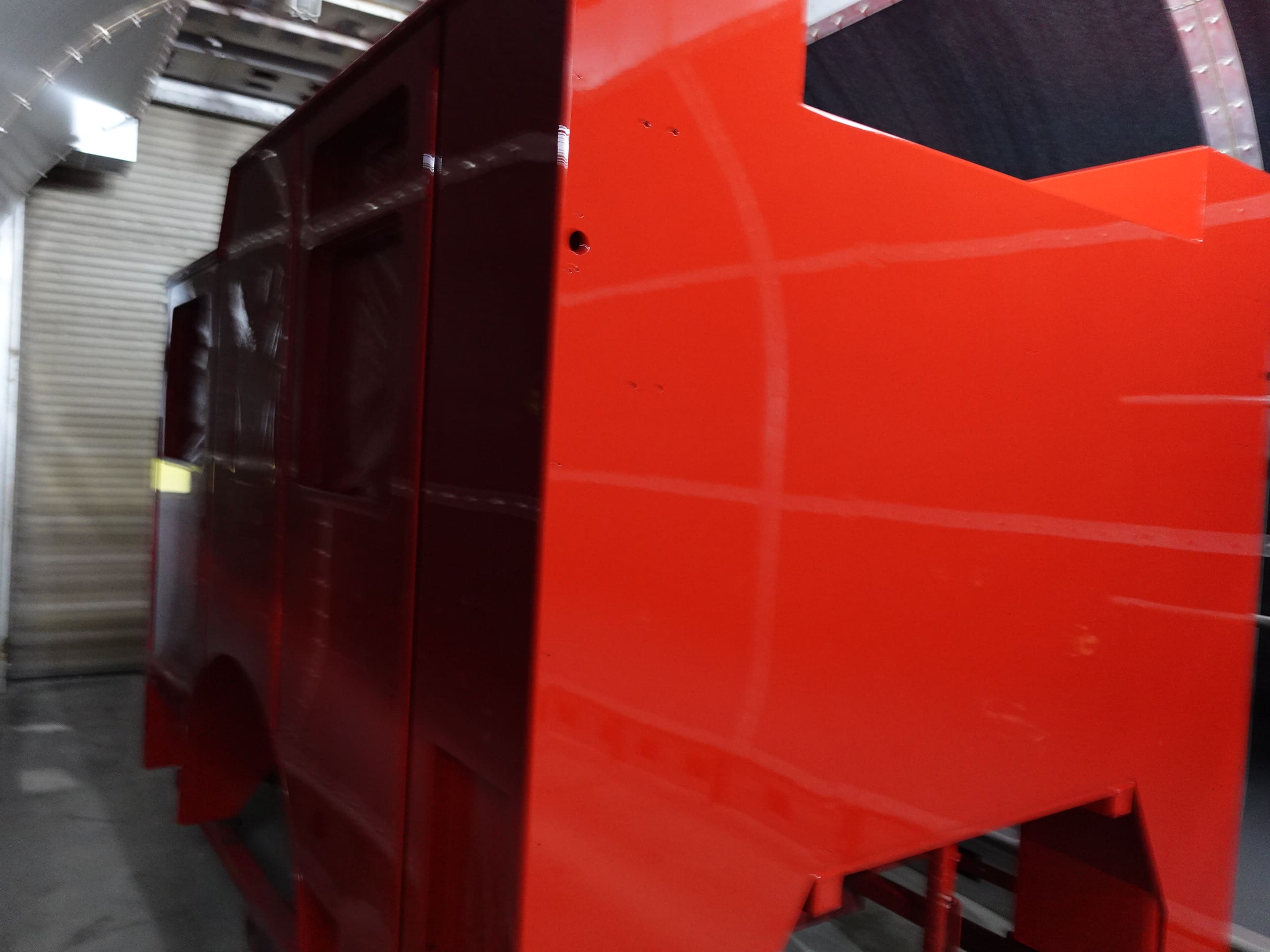

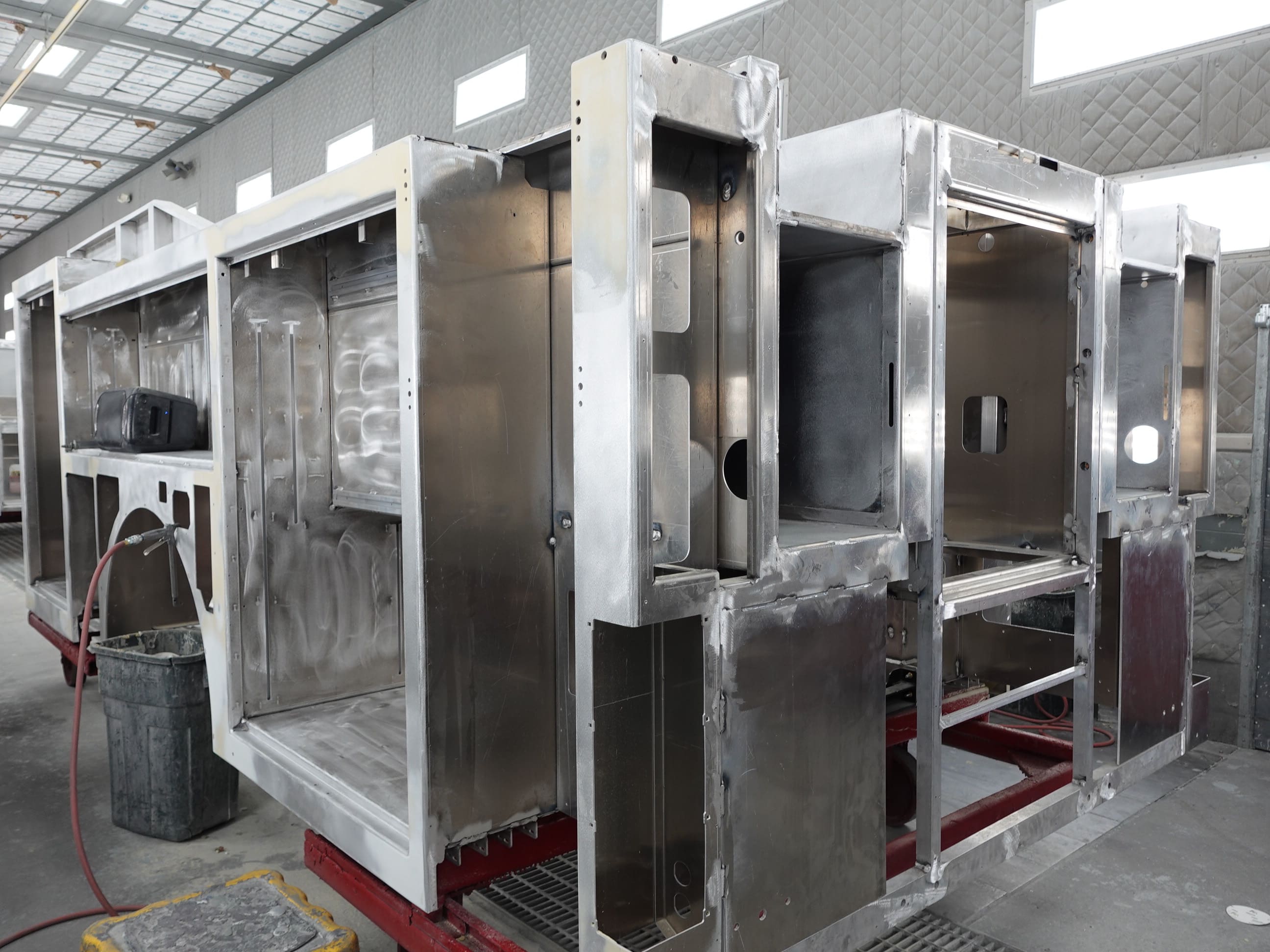

In this report, the cab remained staged, the frame build continued, the pump house and pedestal remained staged, and the body completed the paint process.
02-20-26

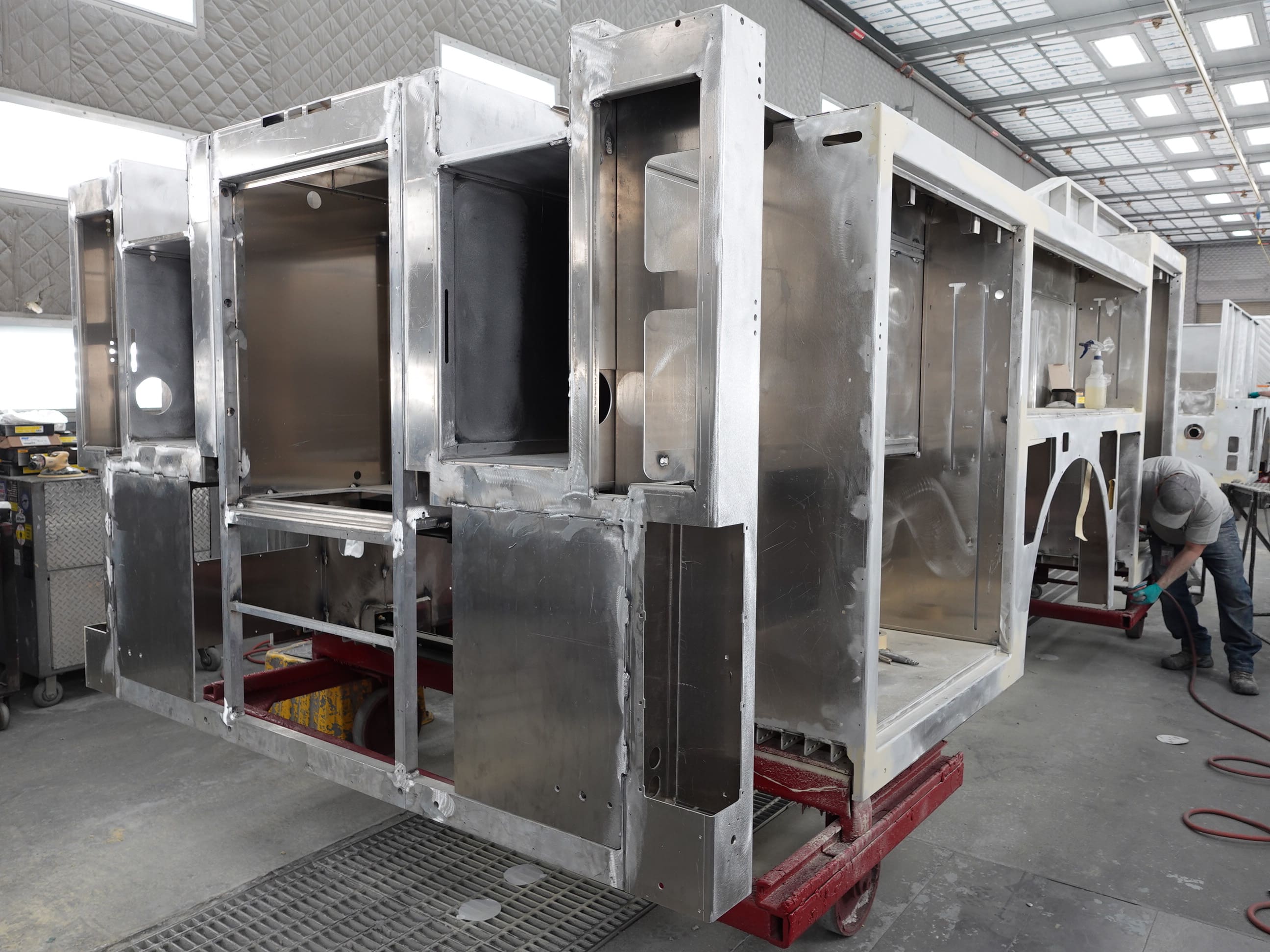

In this report, the cab completed initial assembly, the frame build continued, the pump house was staged, and the body continued through paint.
02-13-26
In this report, the cab began initial assembly, the frame build continued, the pump house completed initial assembly, and the body completed fabrication and began the paint process.
02-06-26
In this report, the cab was staged to begin initial assembly, the frame build continued, and the pump house was painted then staged to continue initial assembly, and the body began fabrication.
01-30-26

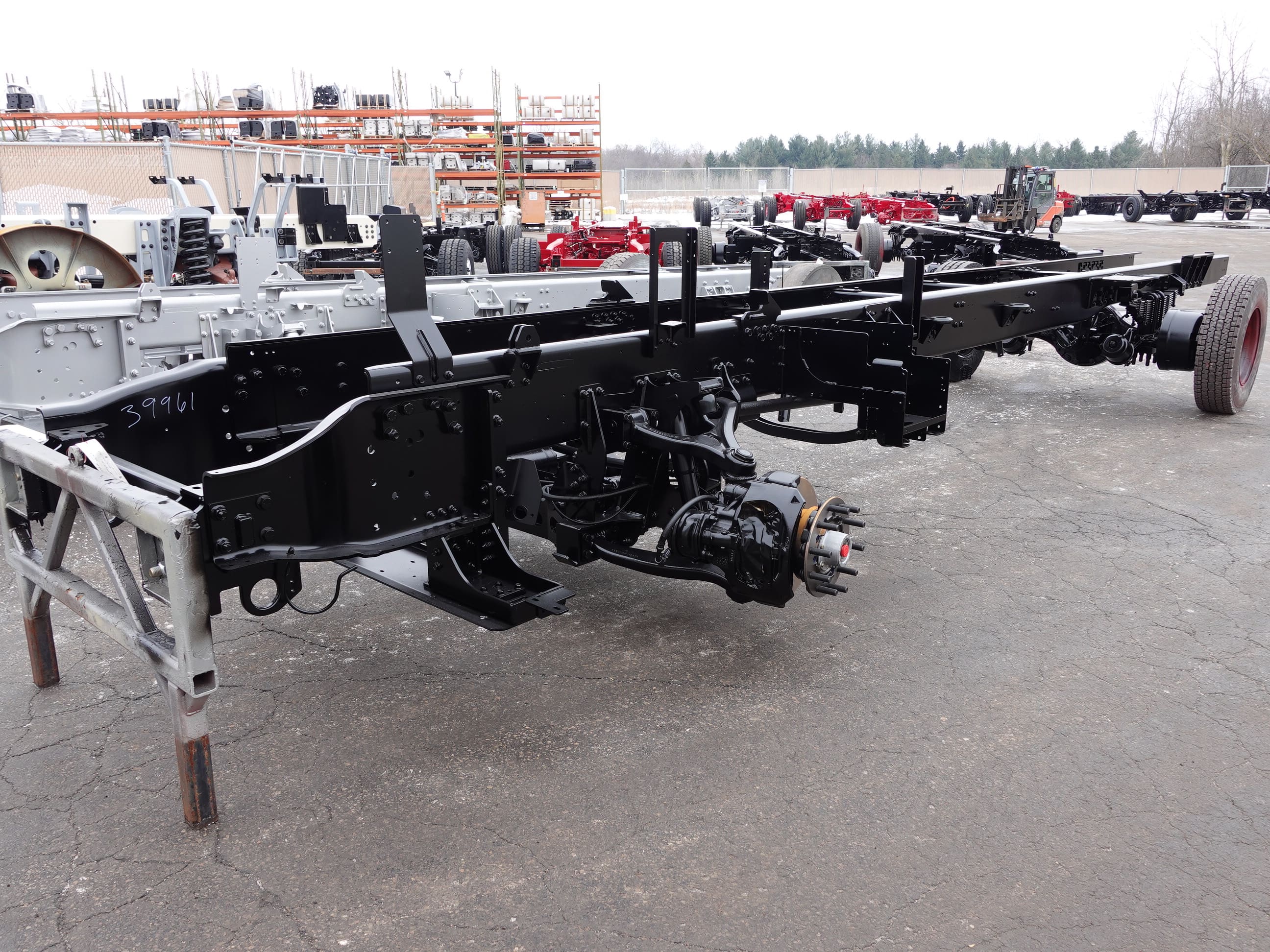

In this report, the cab remained staged, the frame build began, and the pump house began initial assembly.
01-23-26
In this report, the cab completed the paint process while the pump house structure was fabricated.
