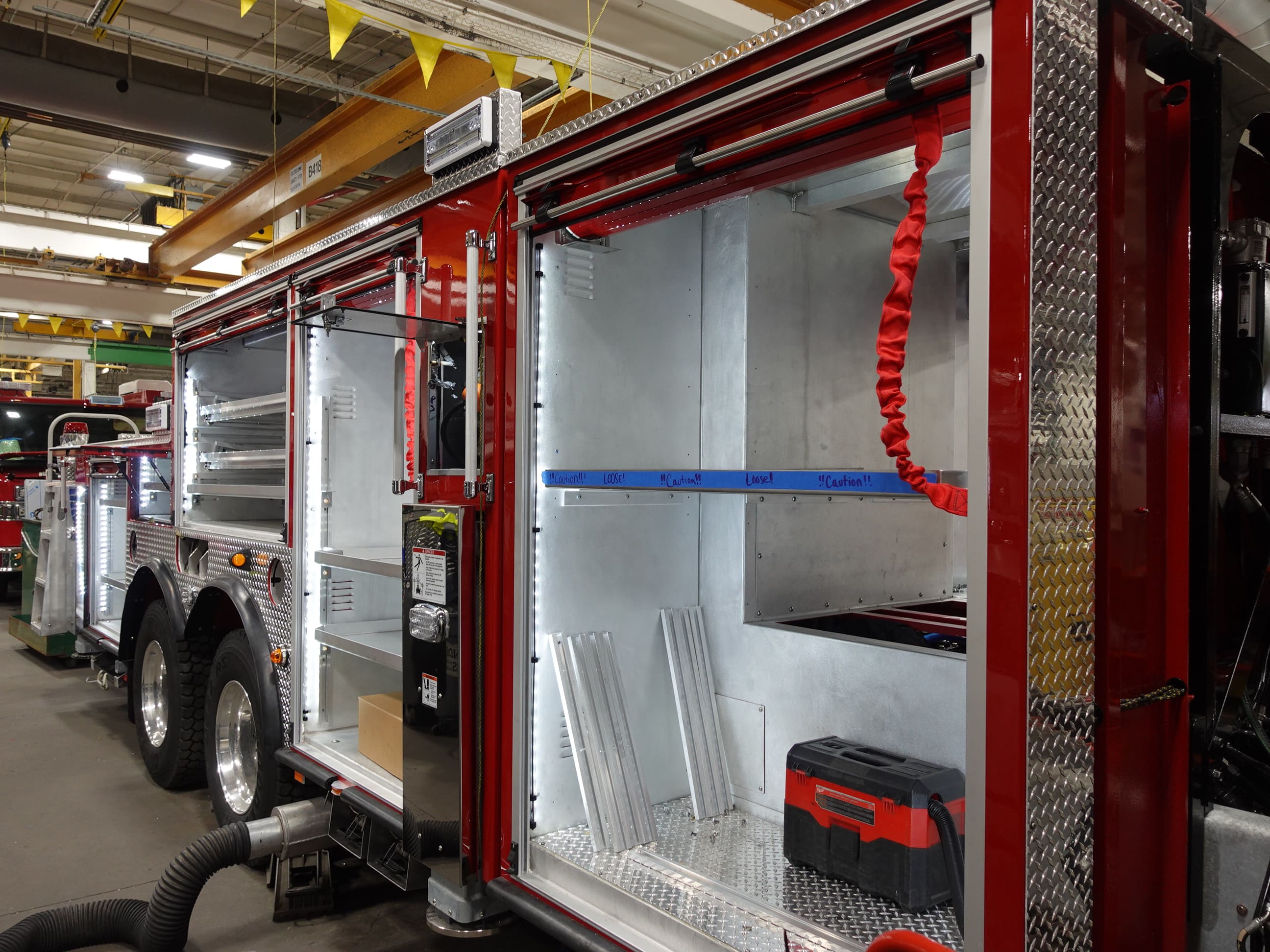

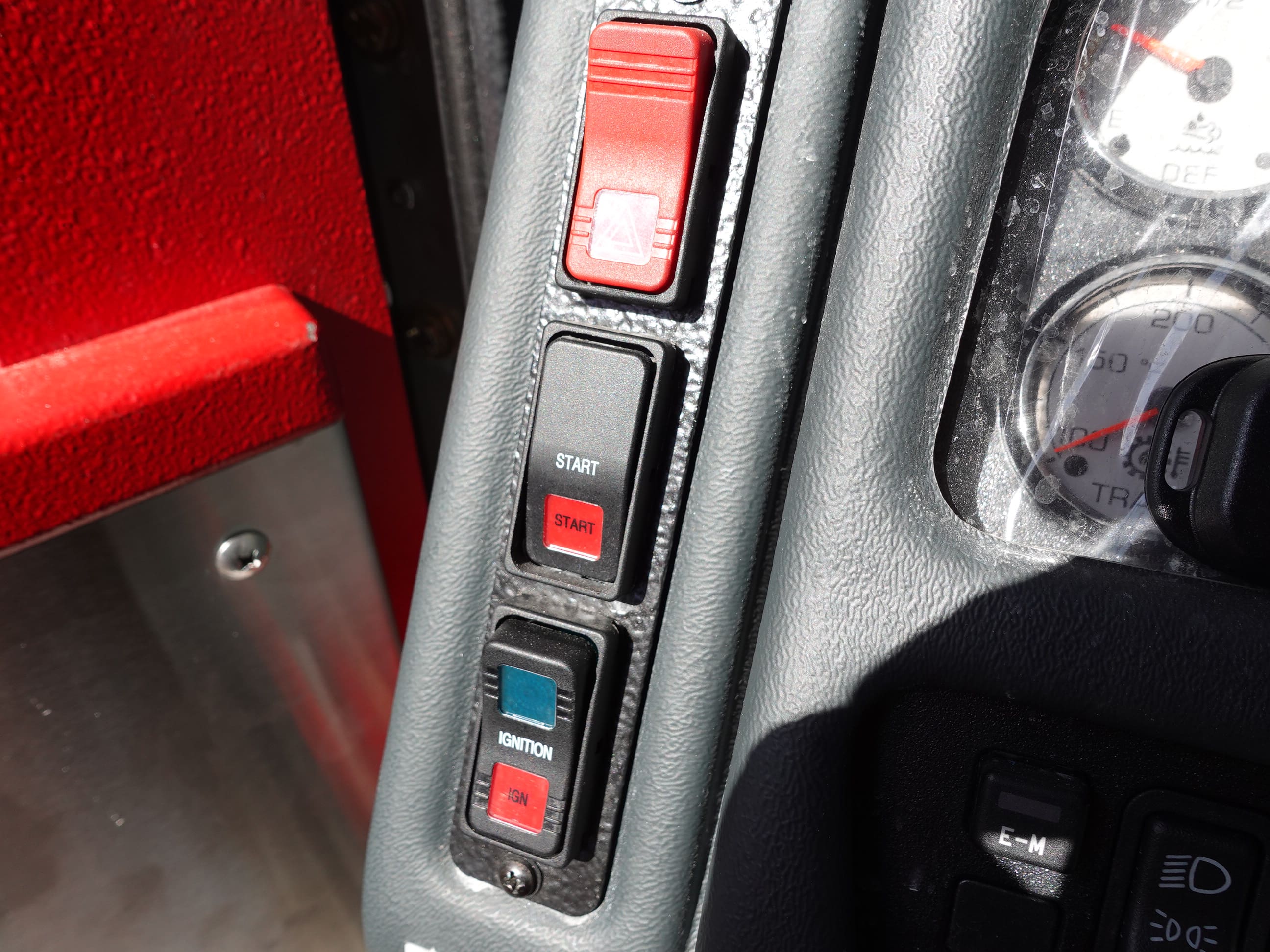

05-08-26

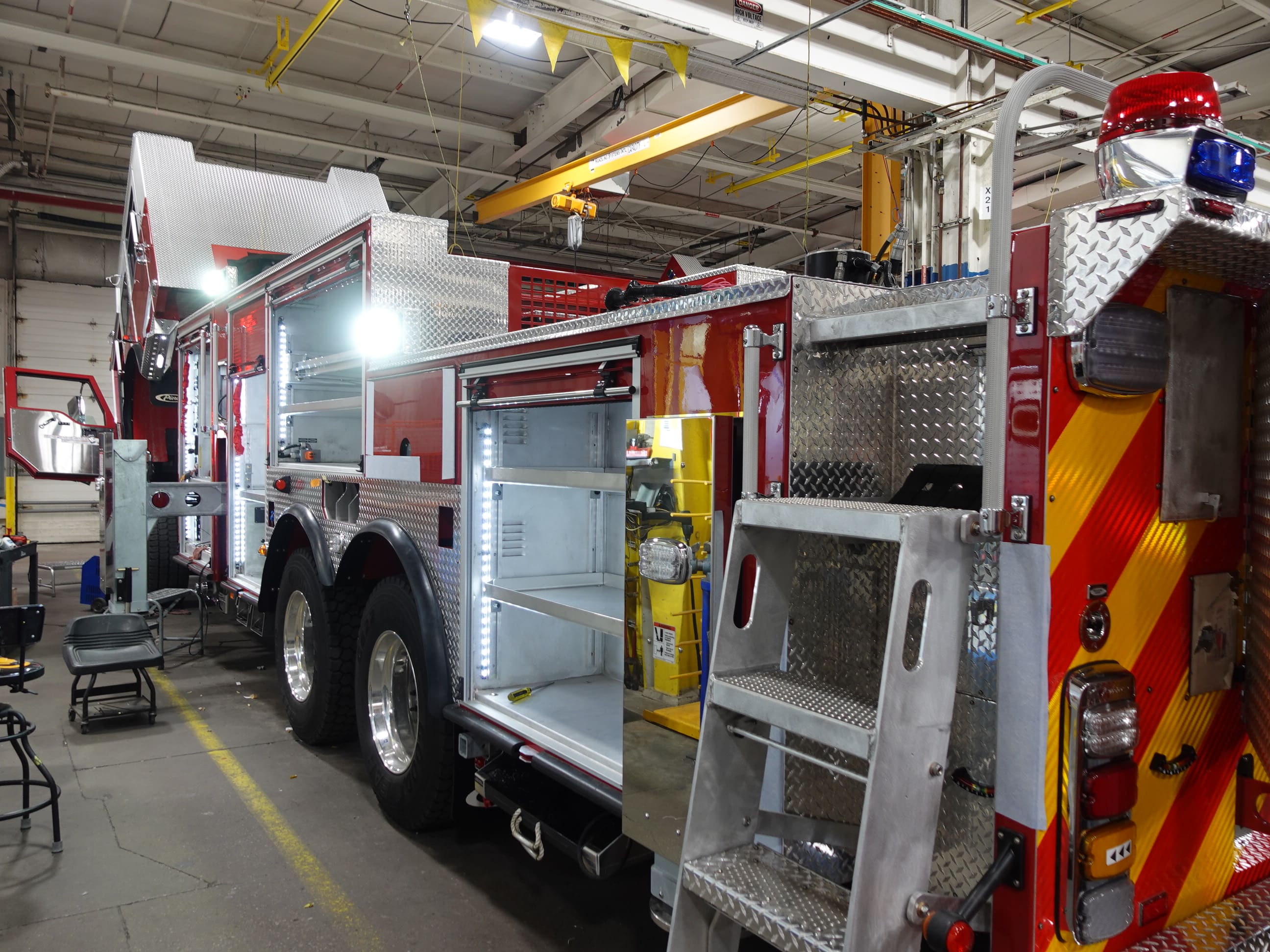

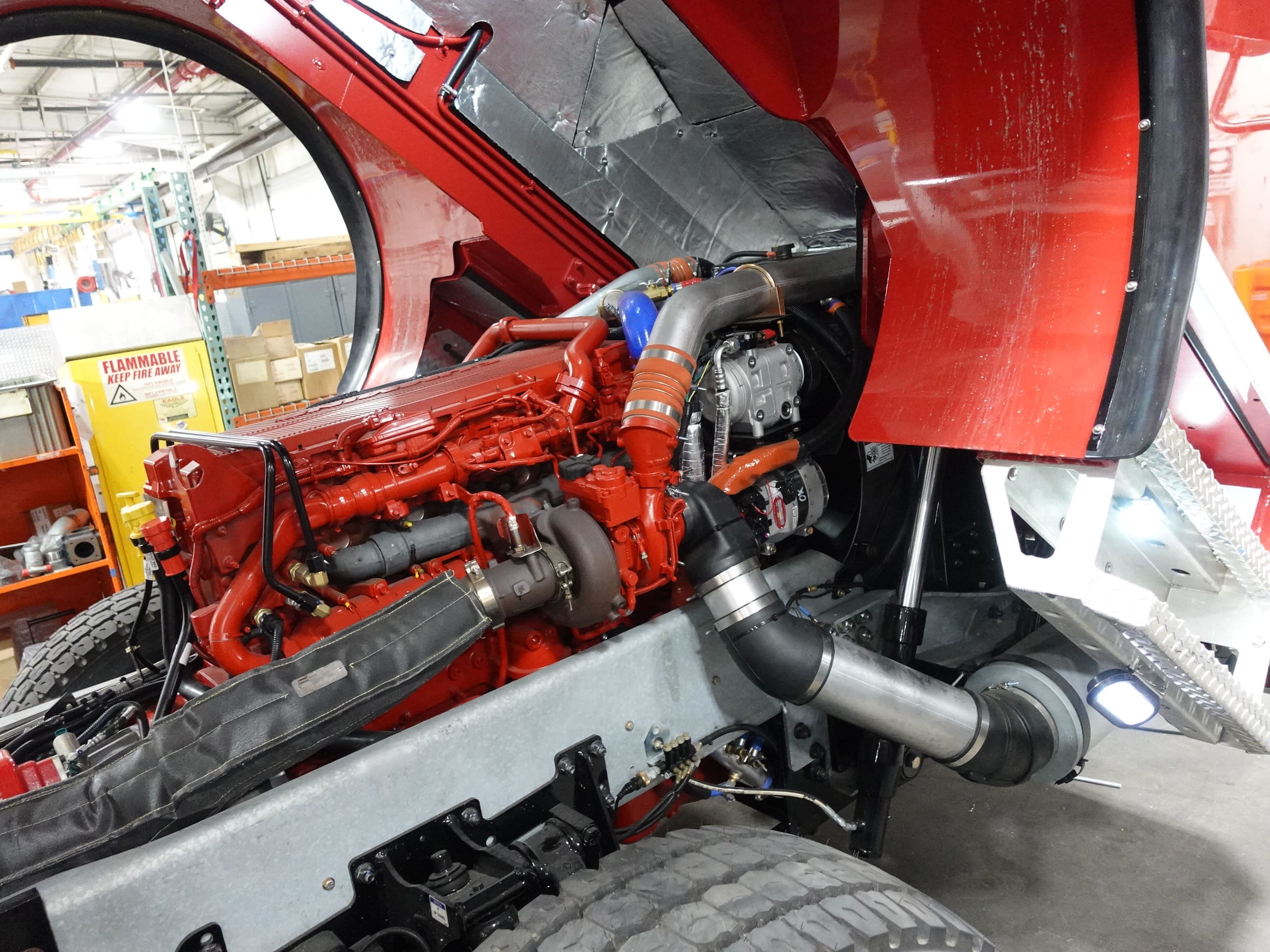

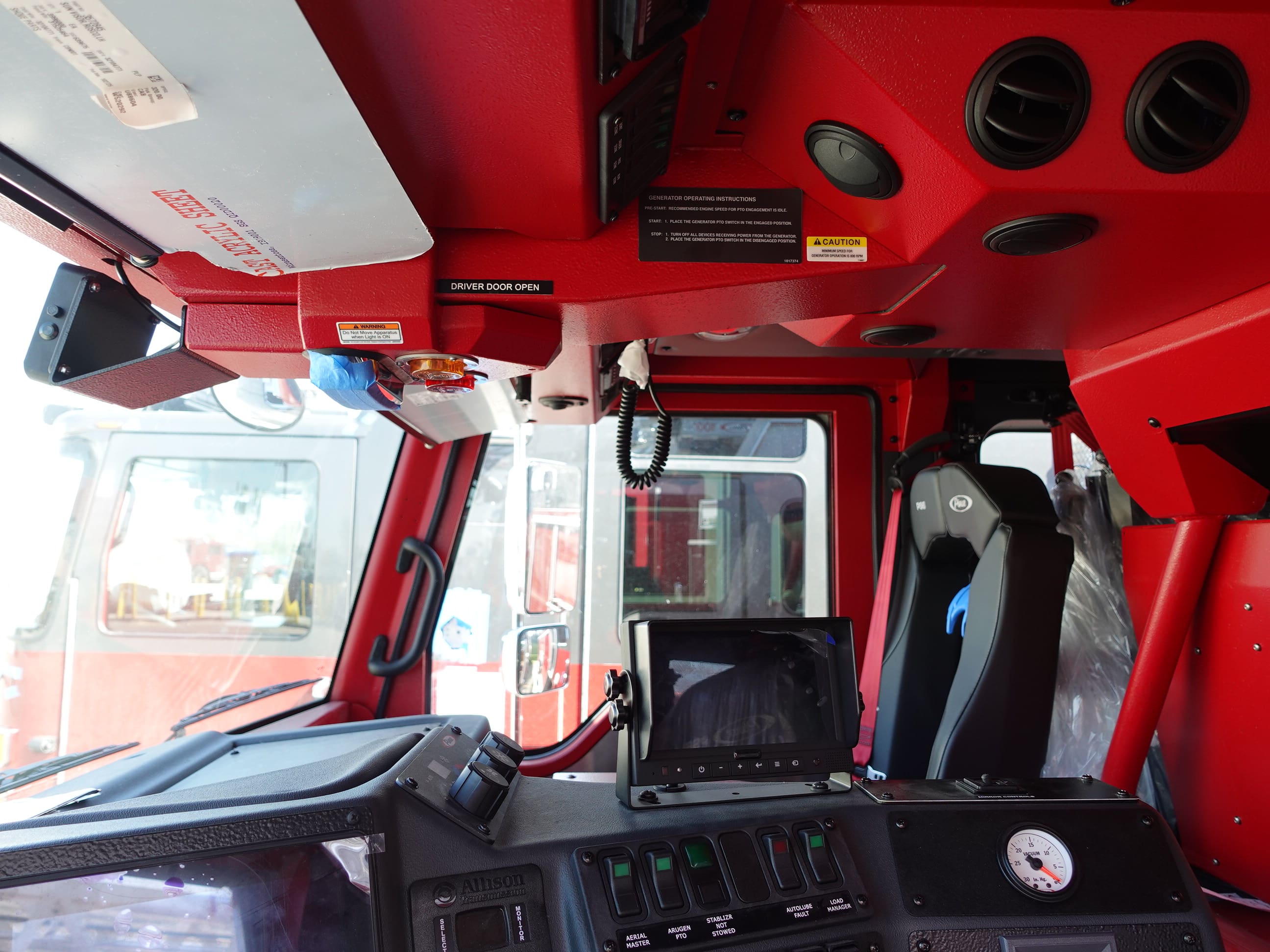

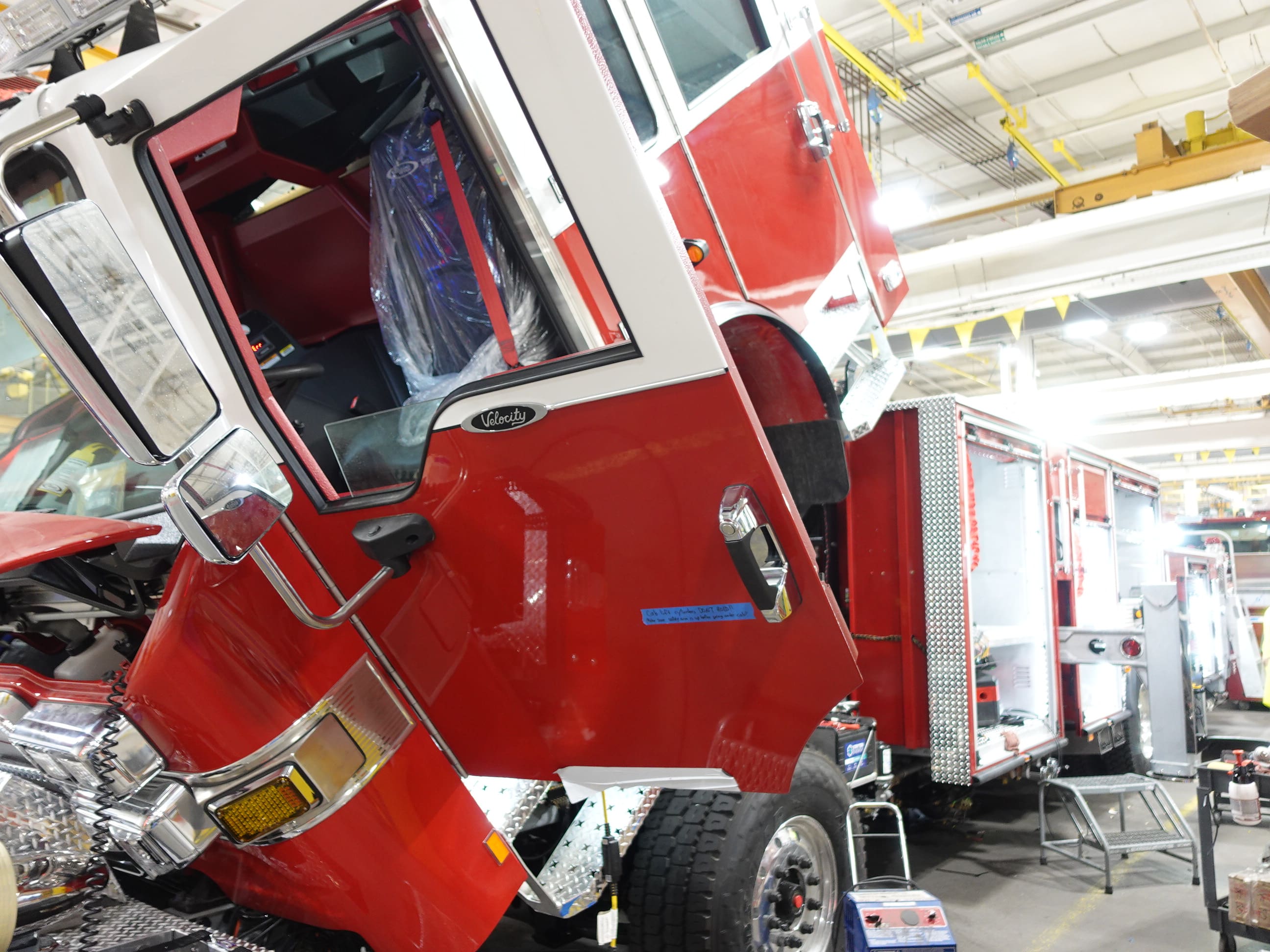

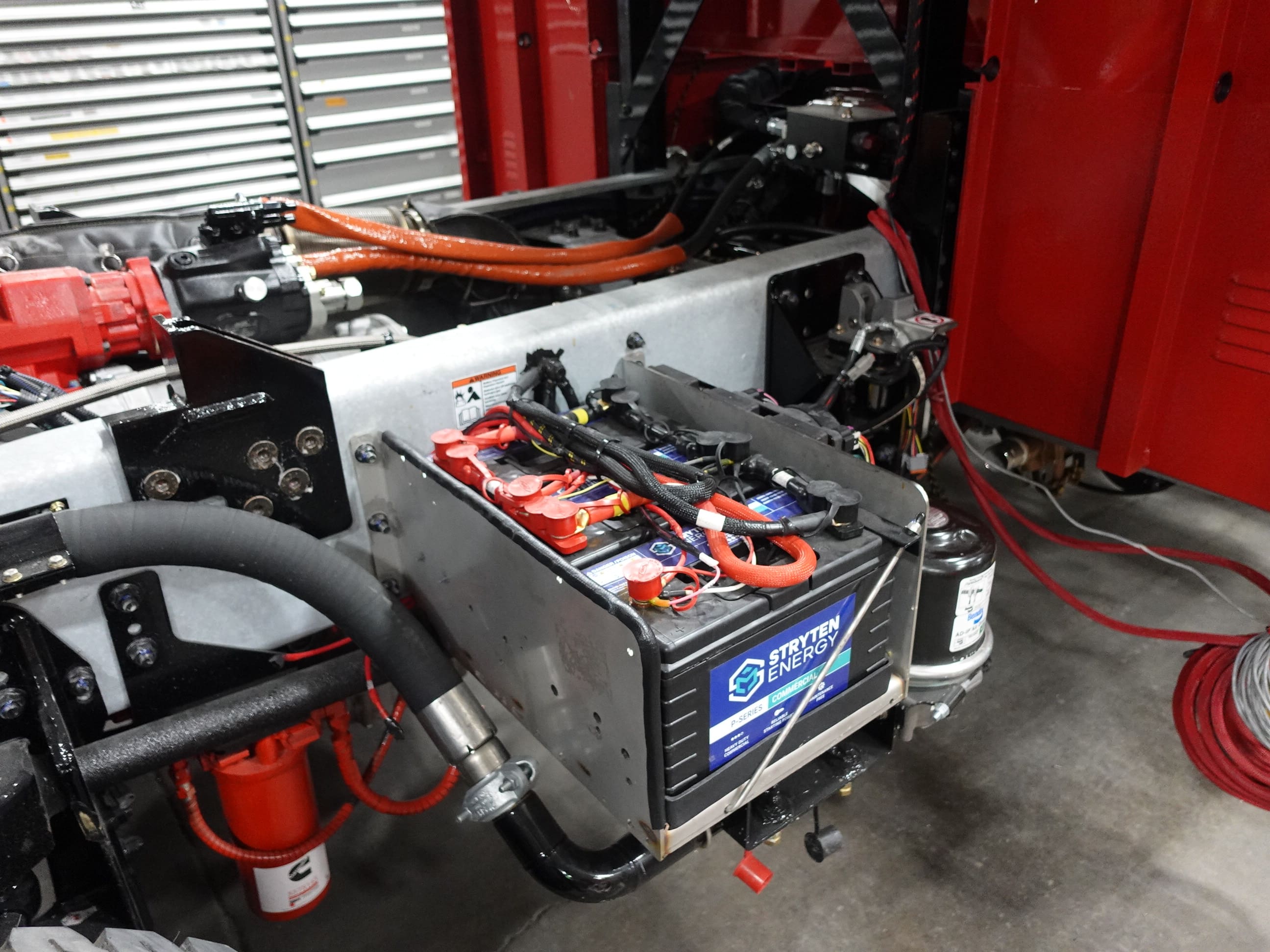

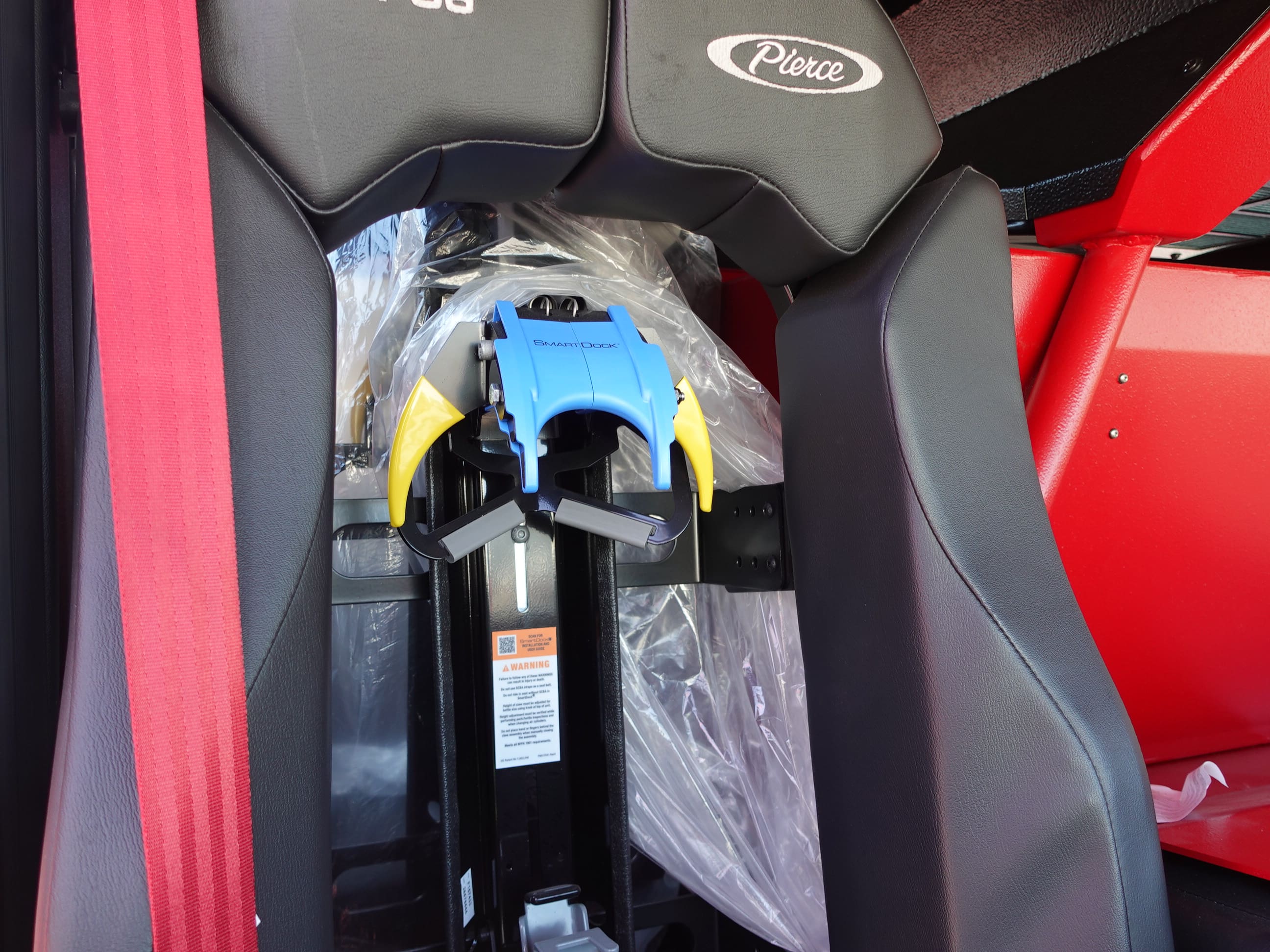

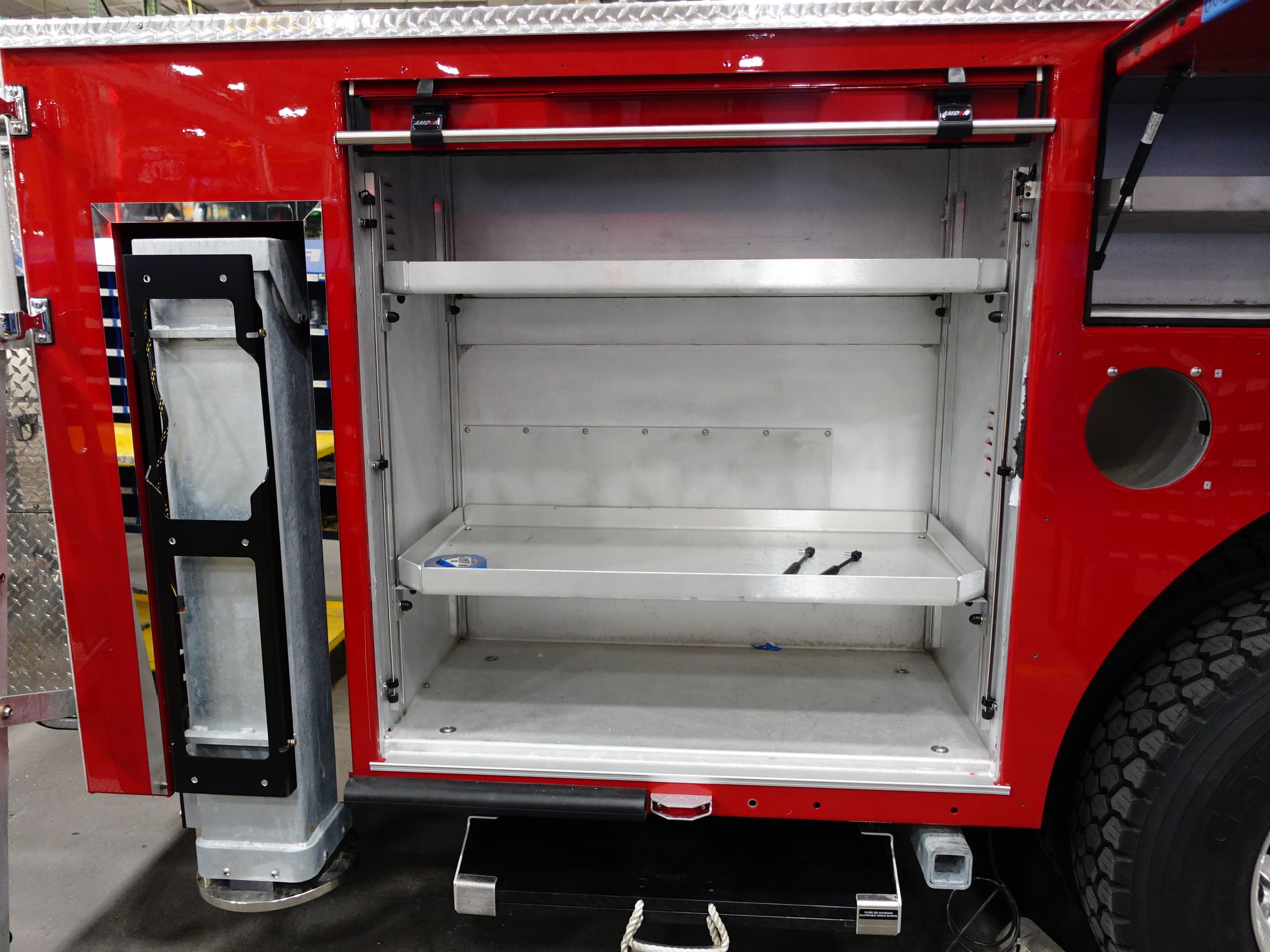

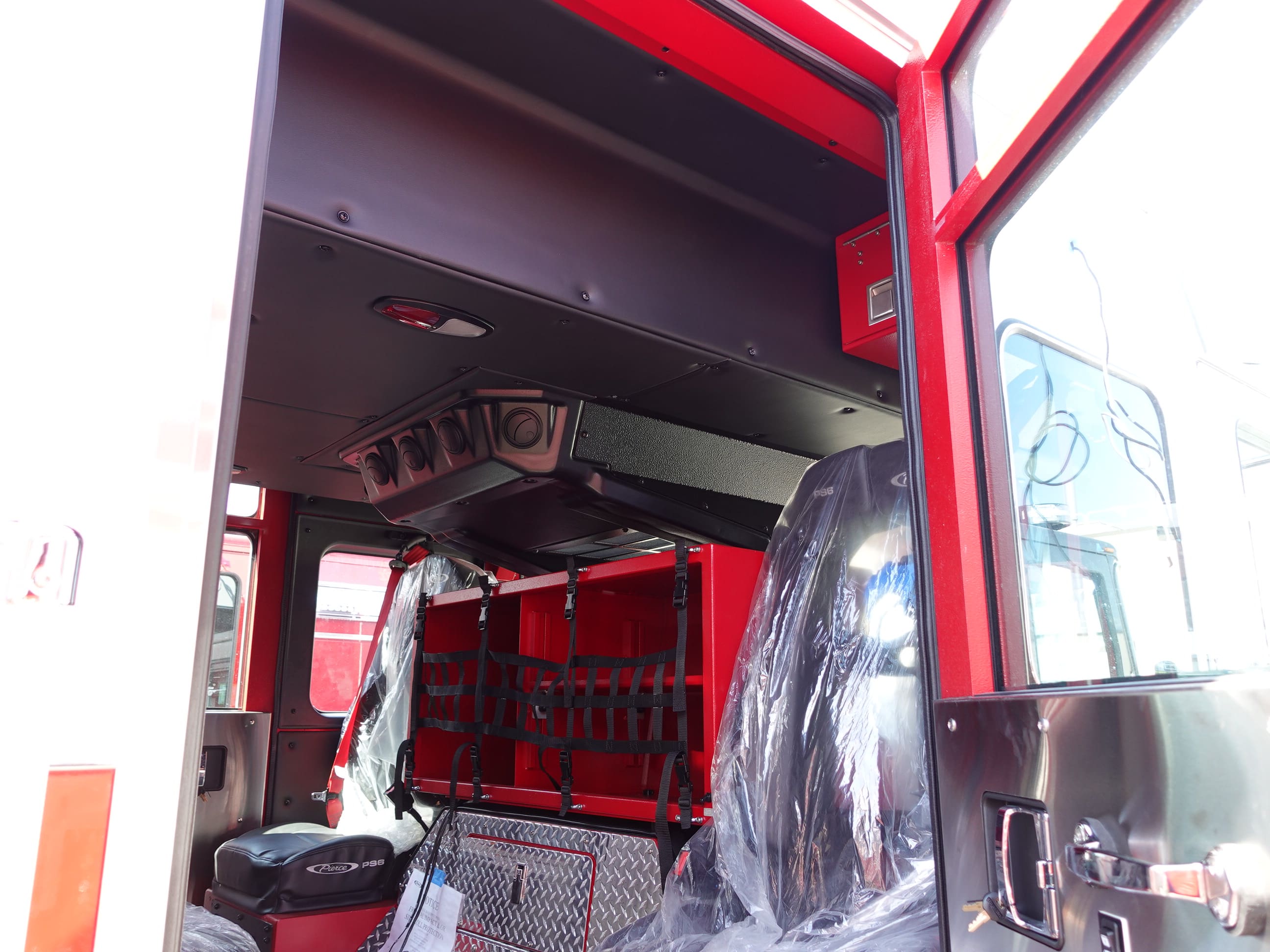

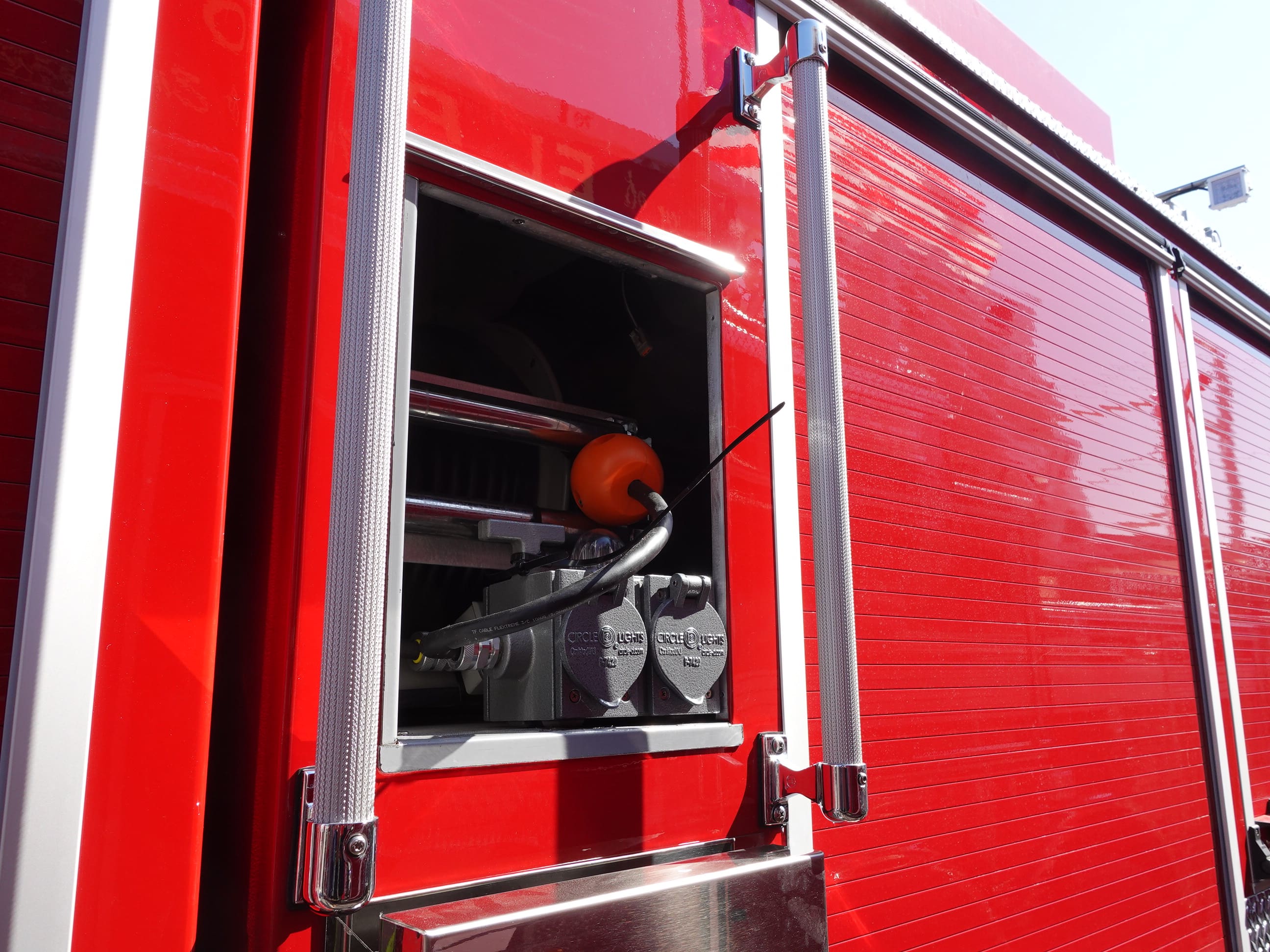

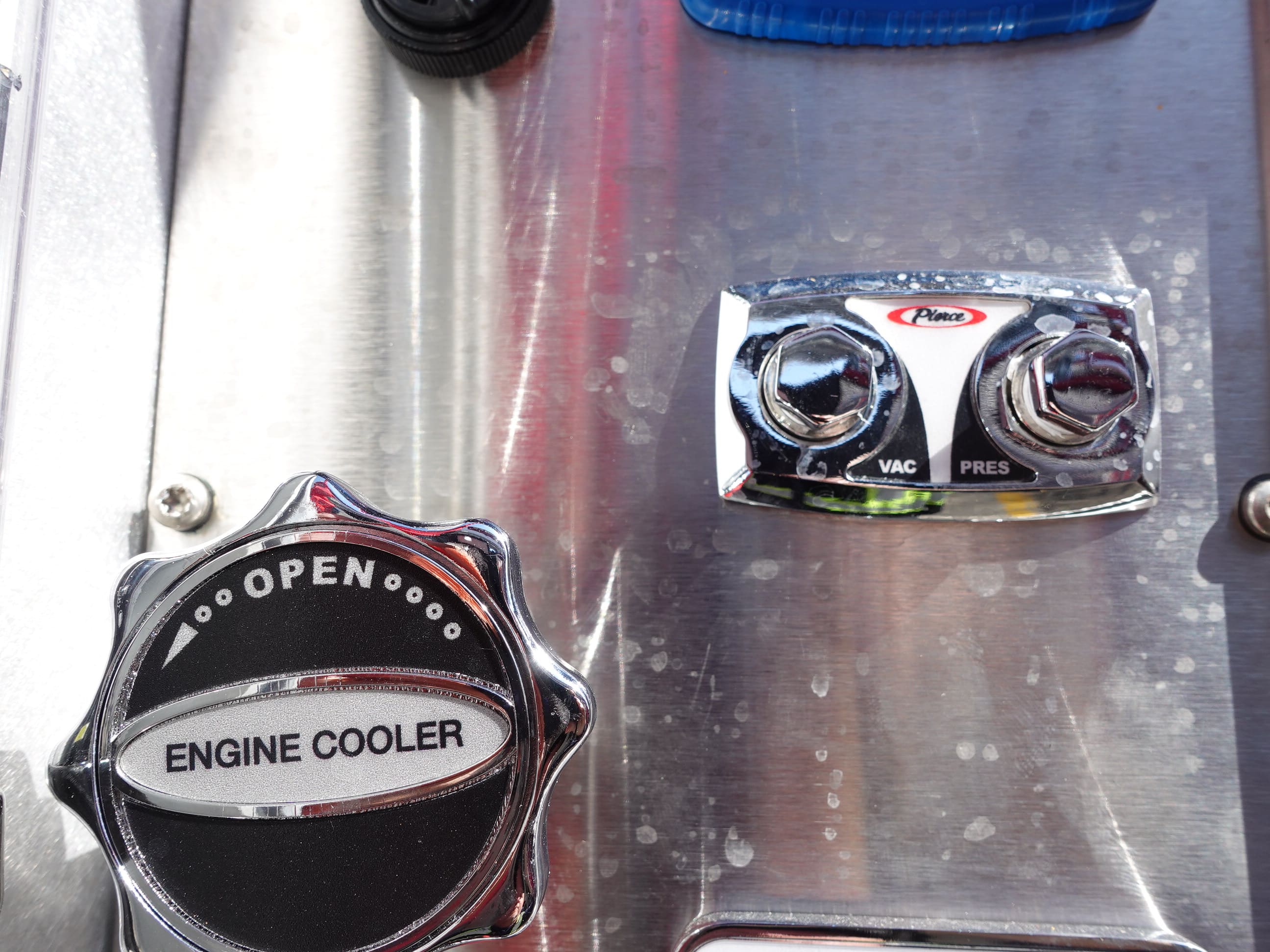

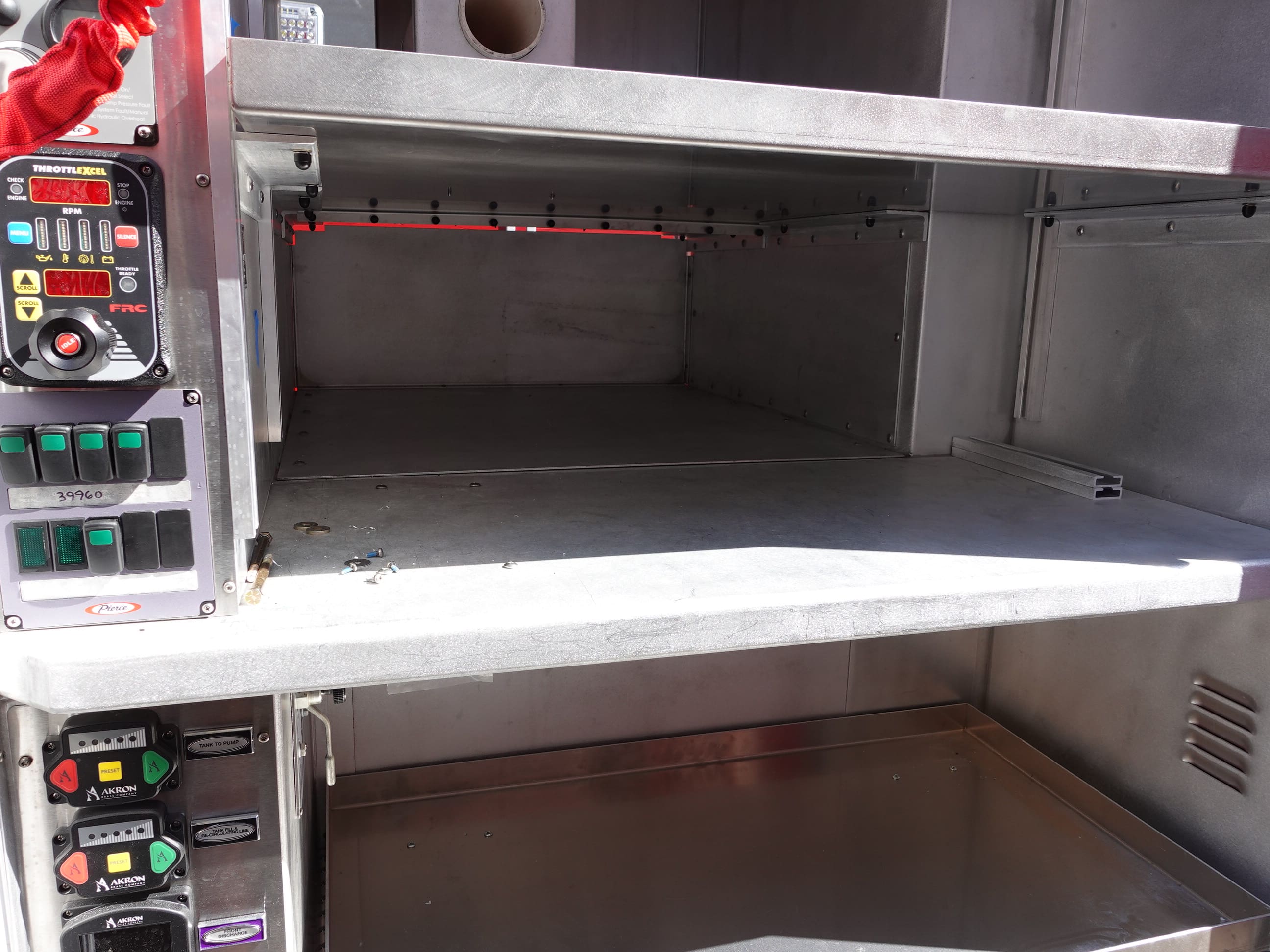

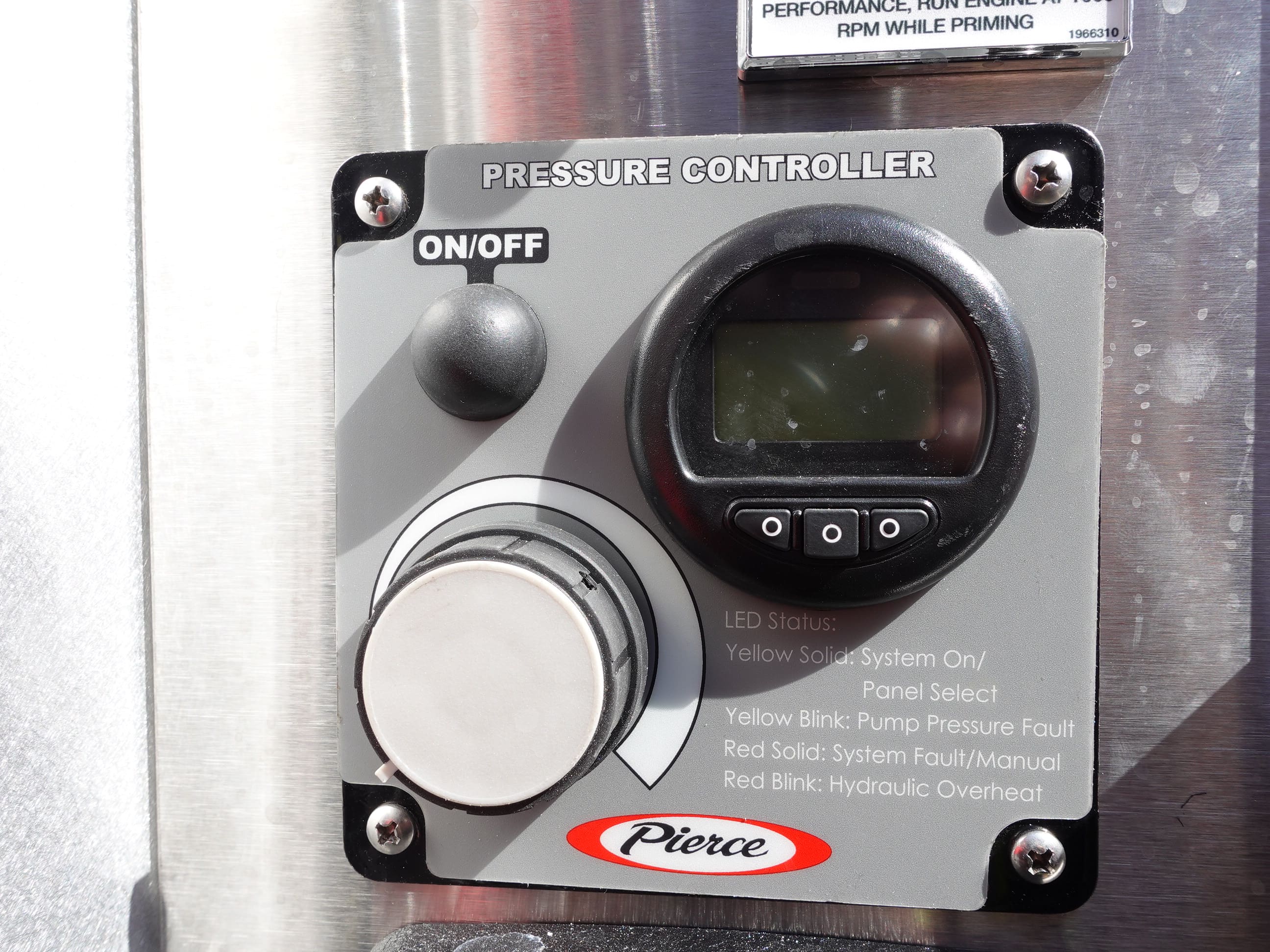

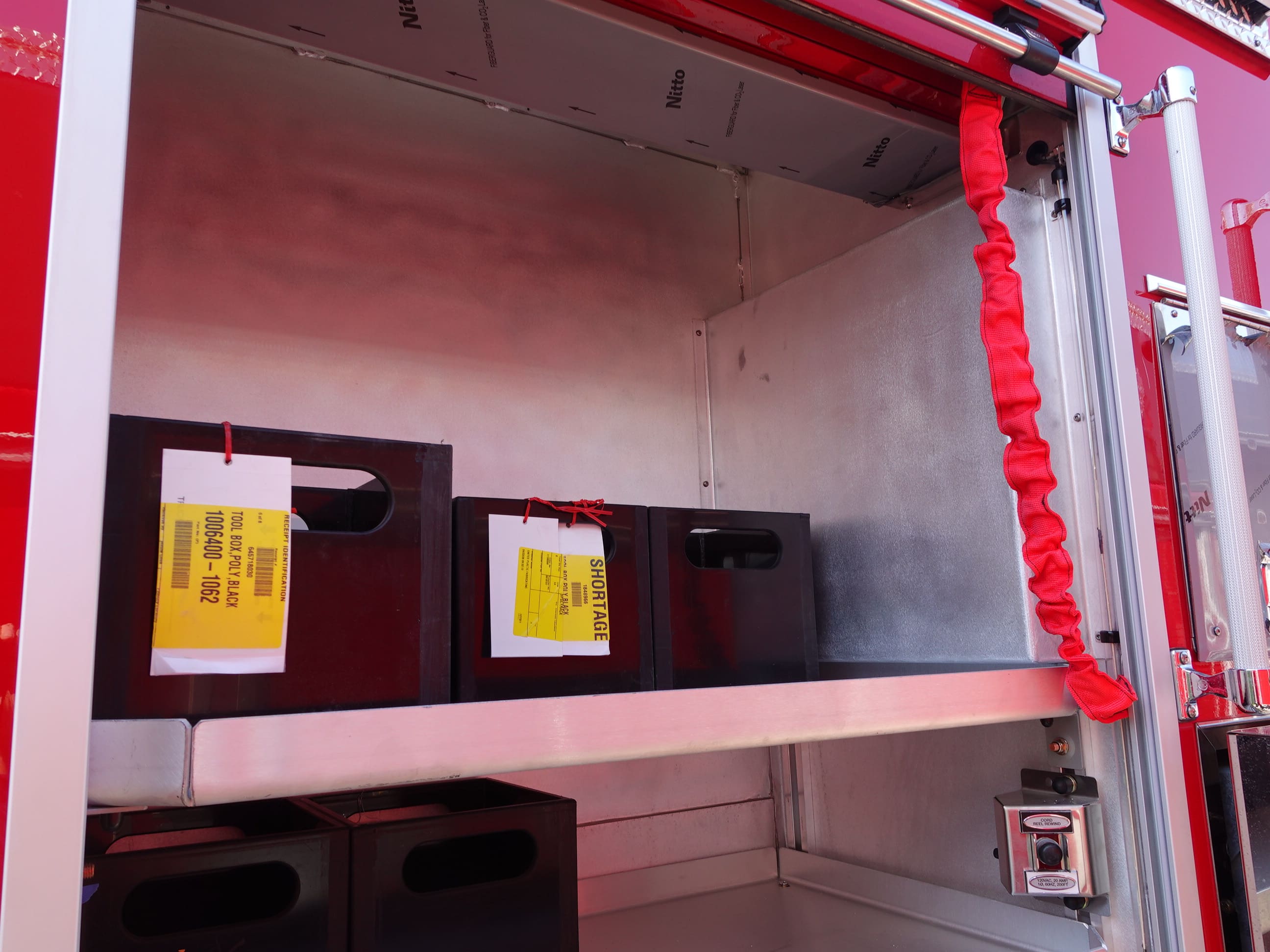

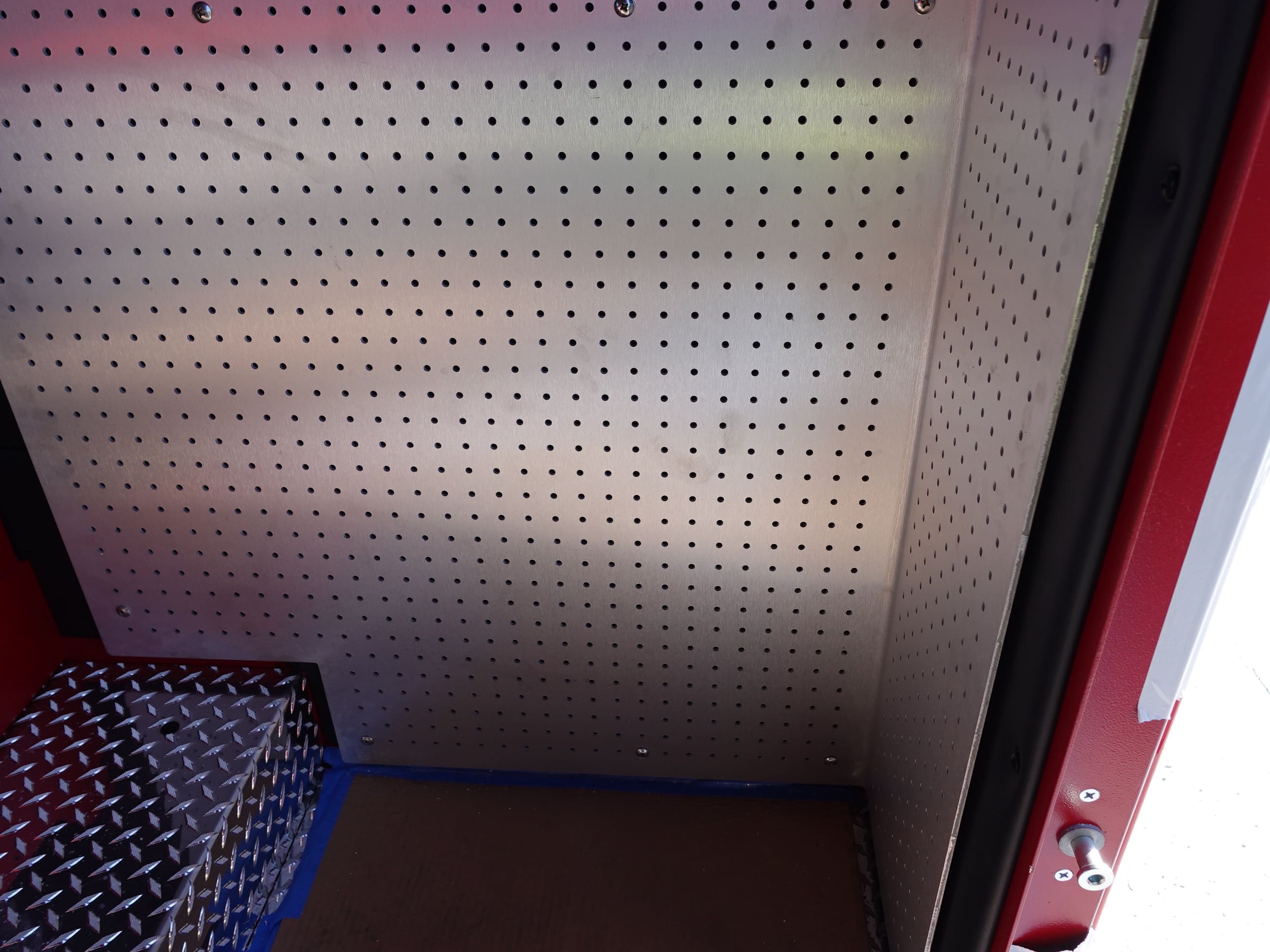

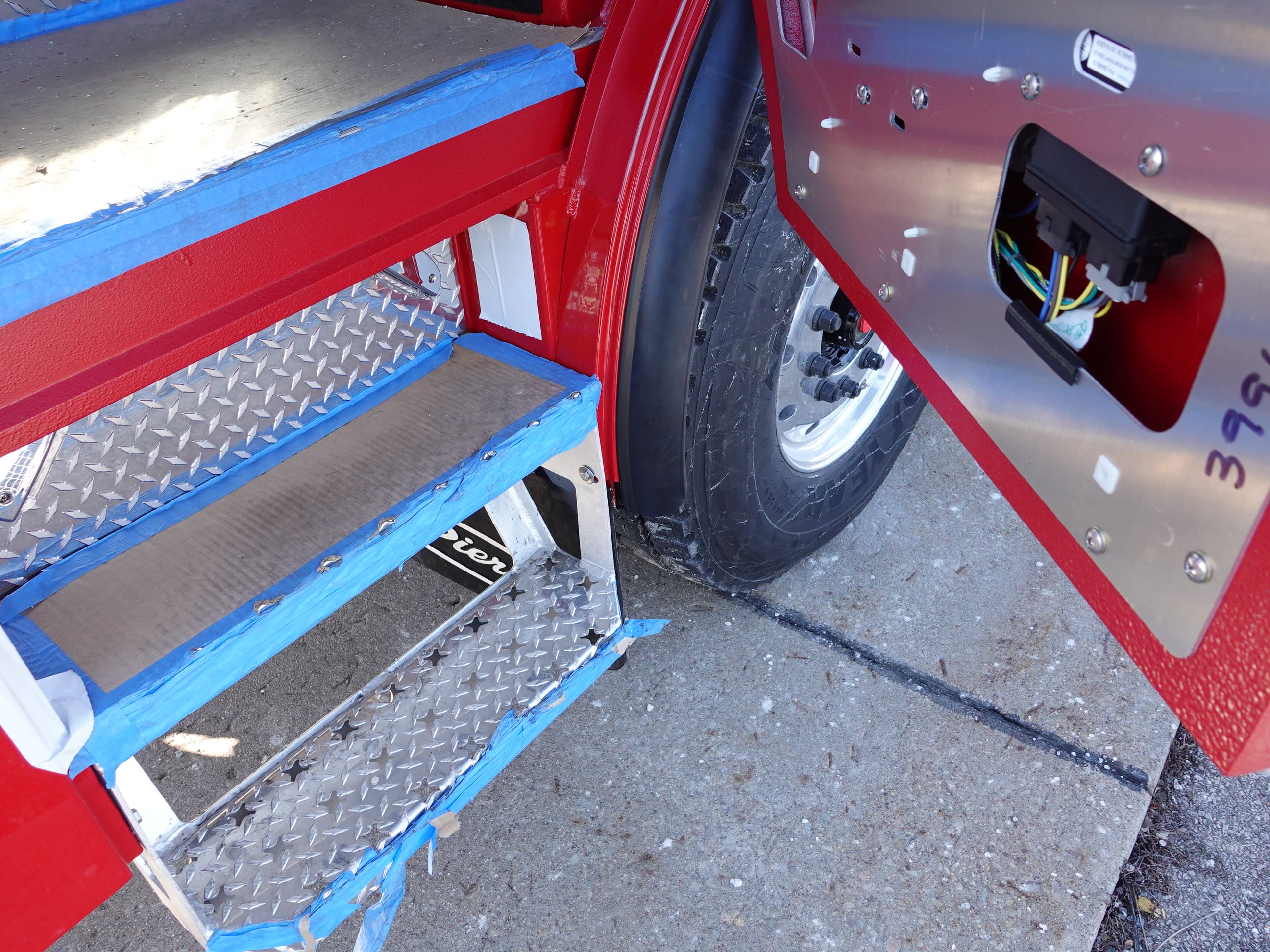

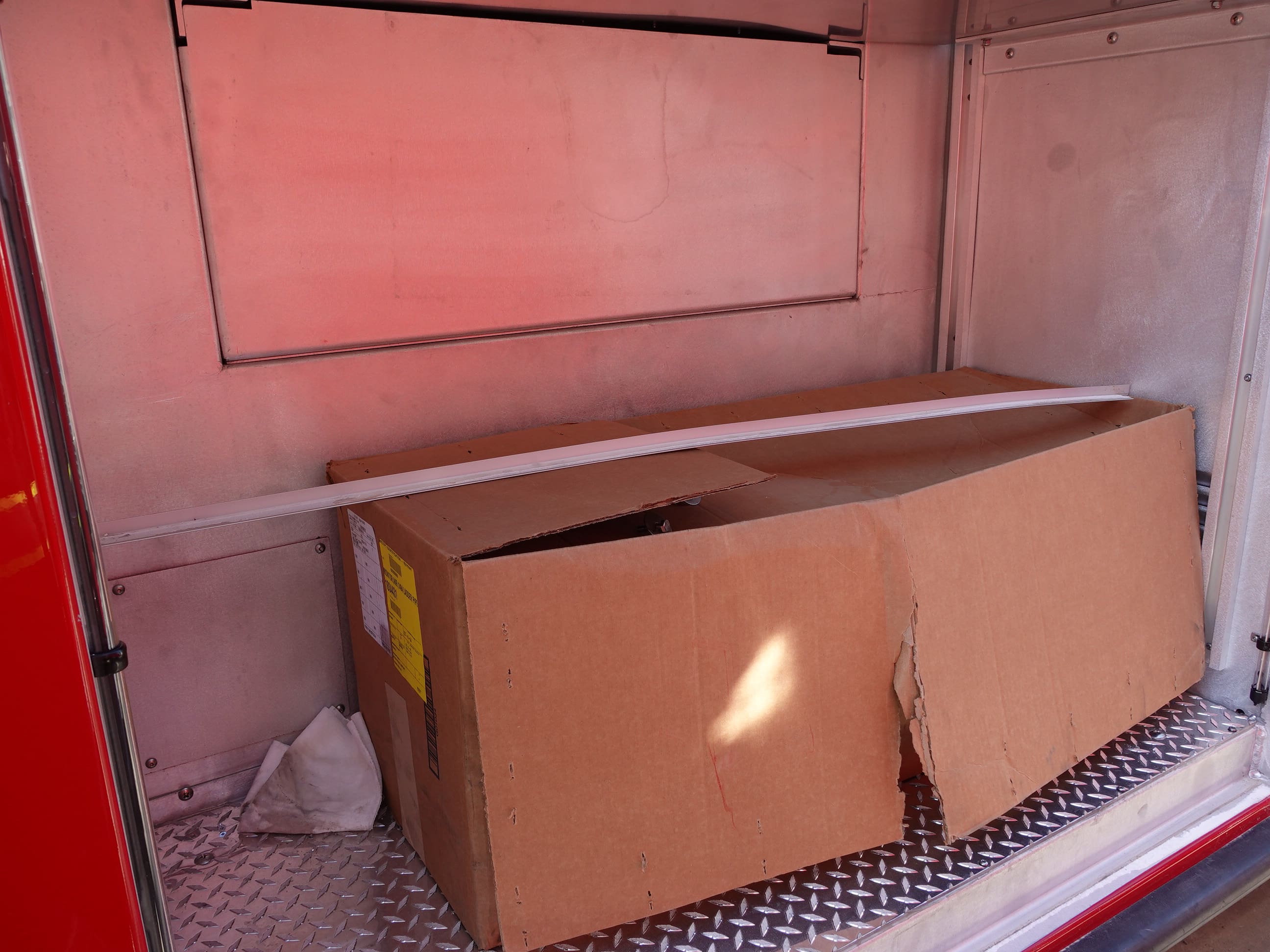

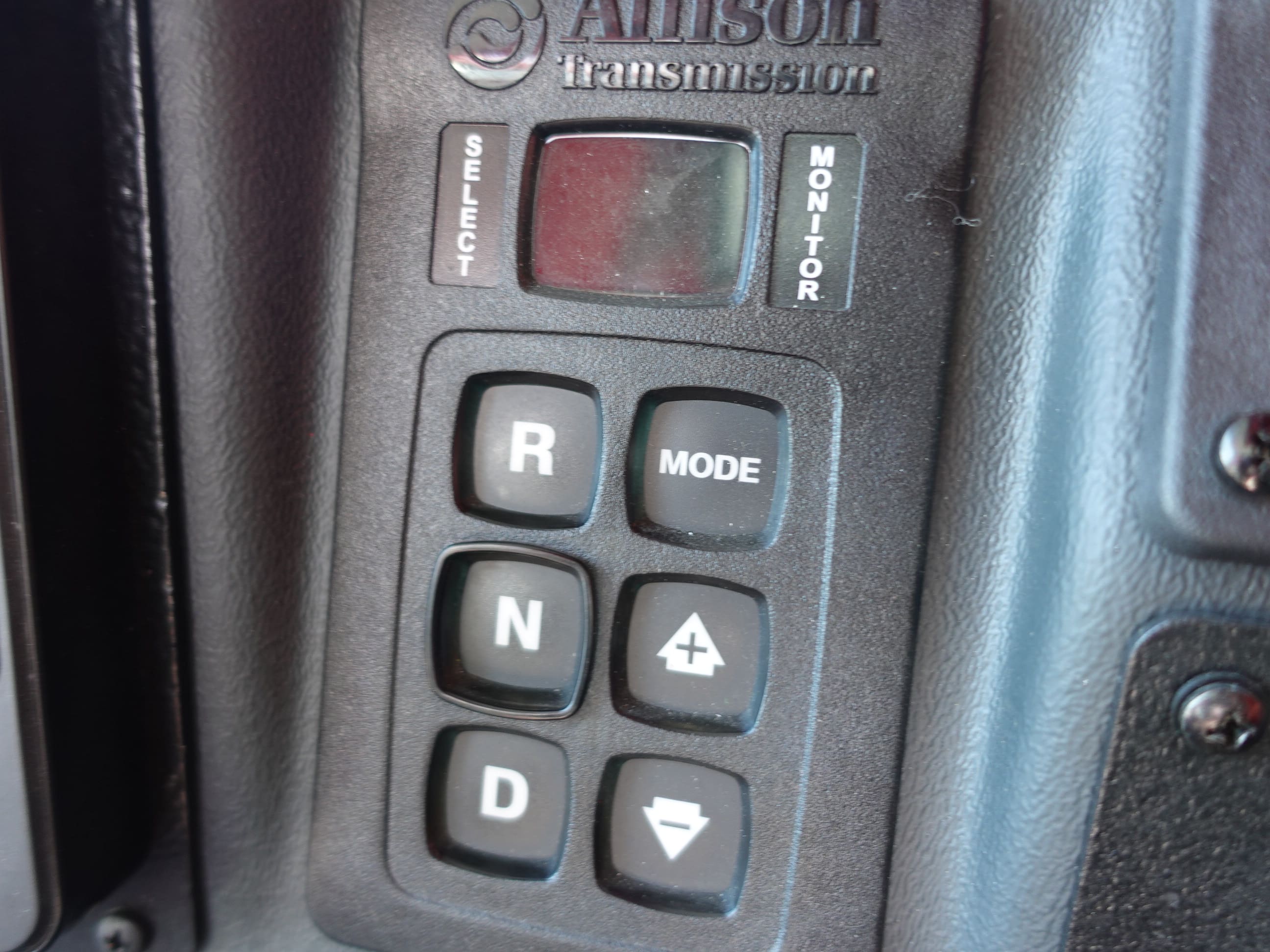

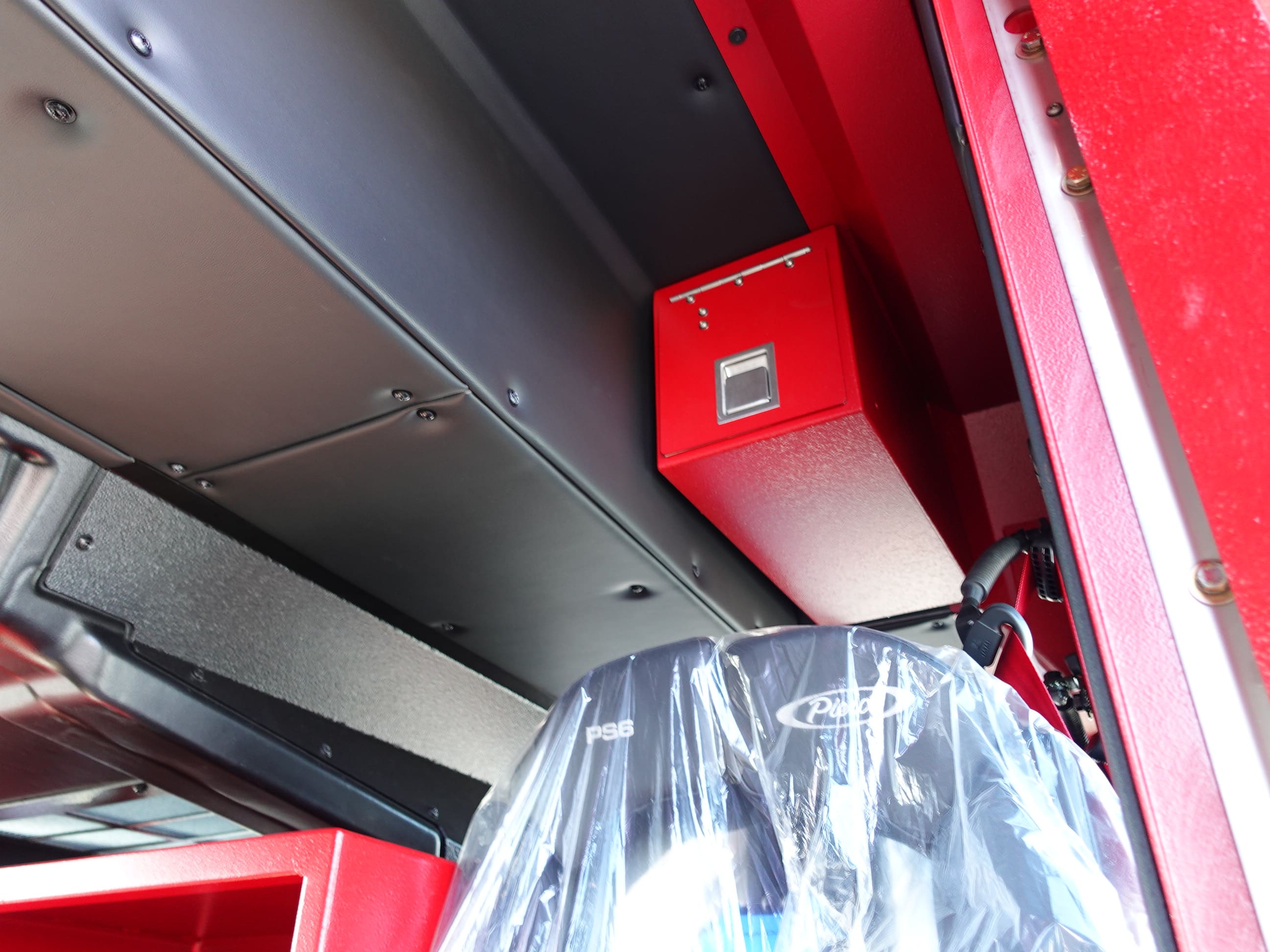

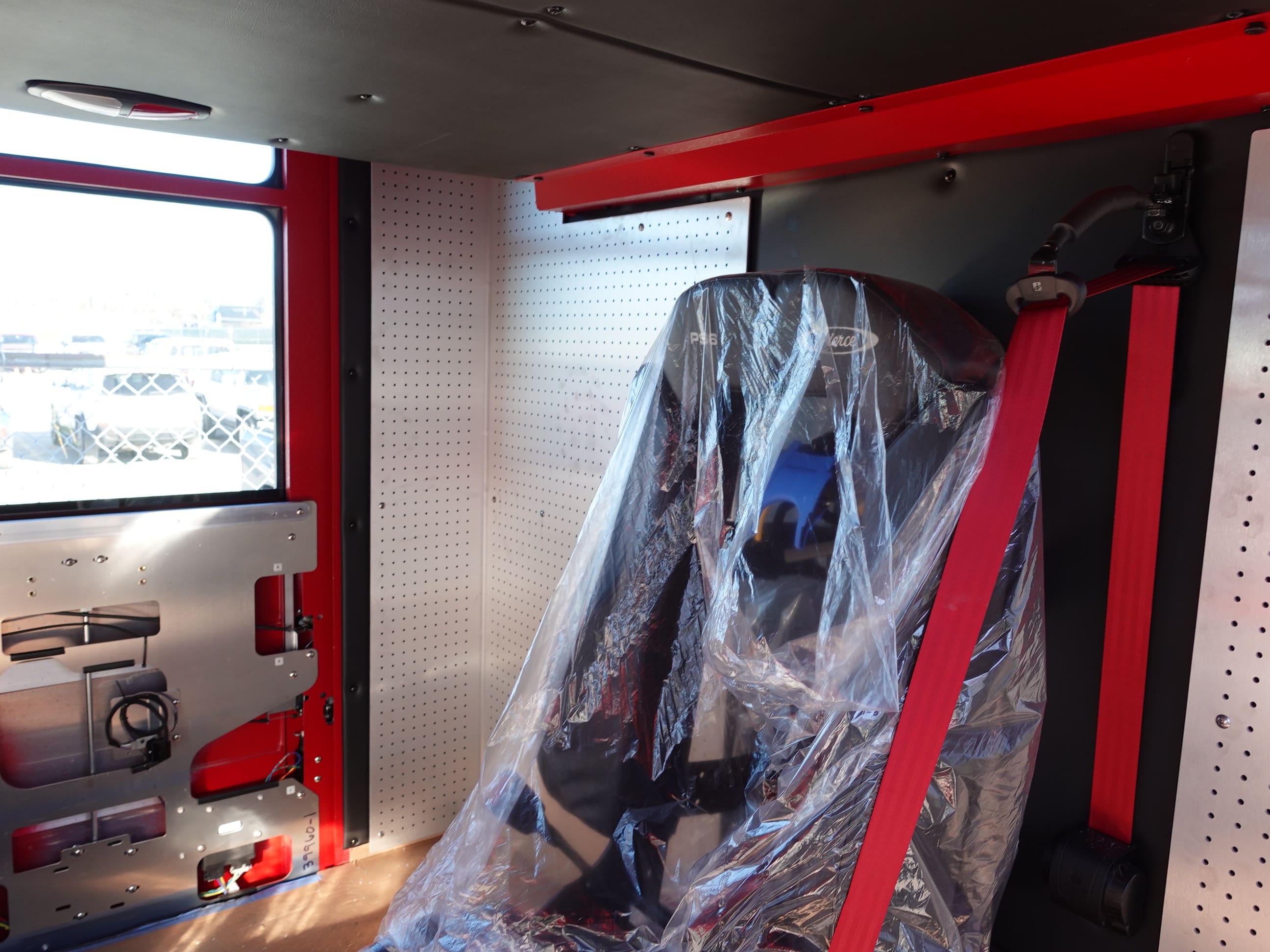

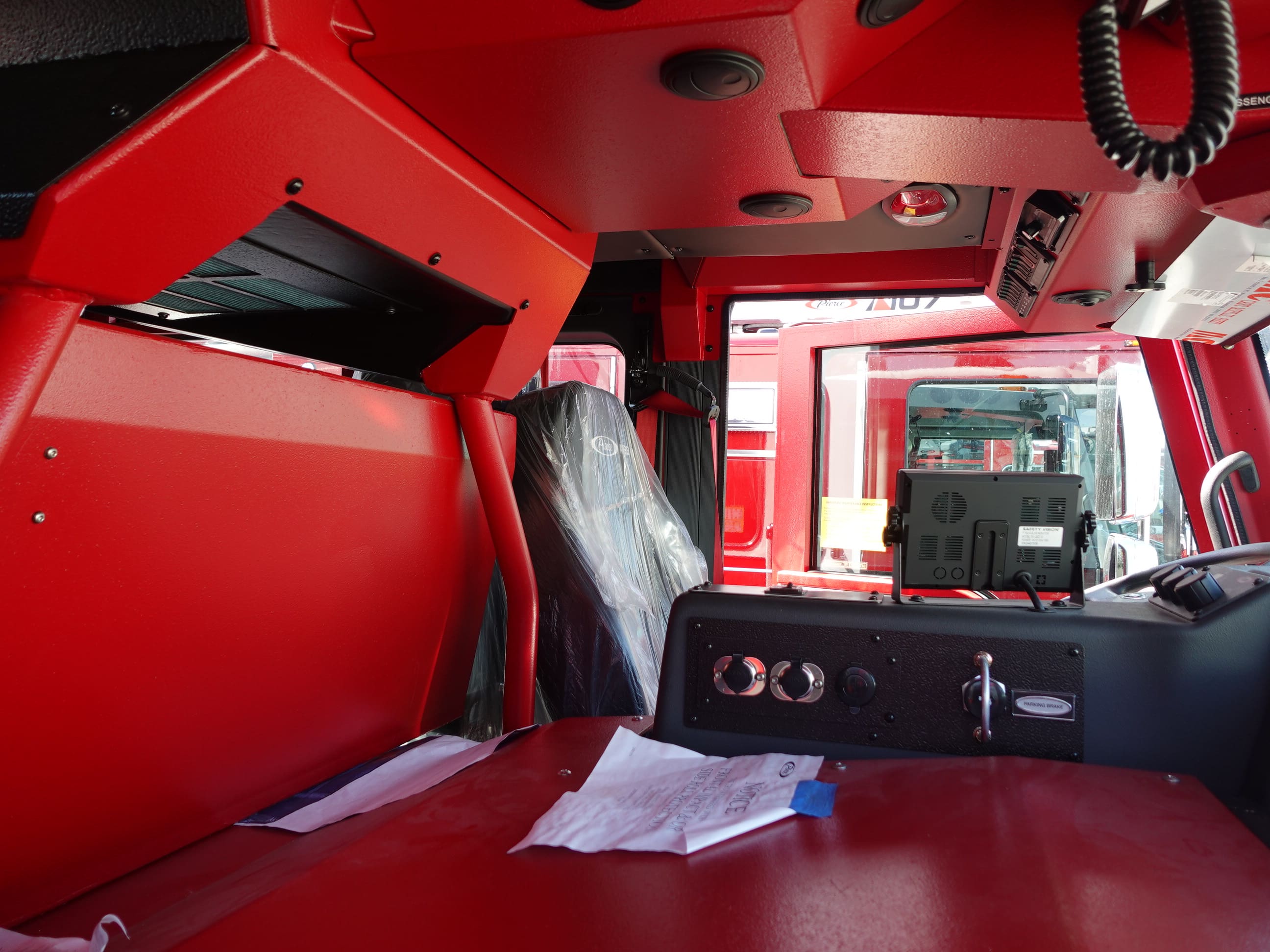

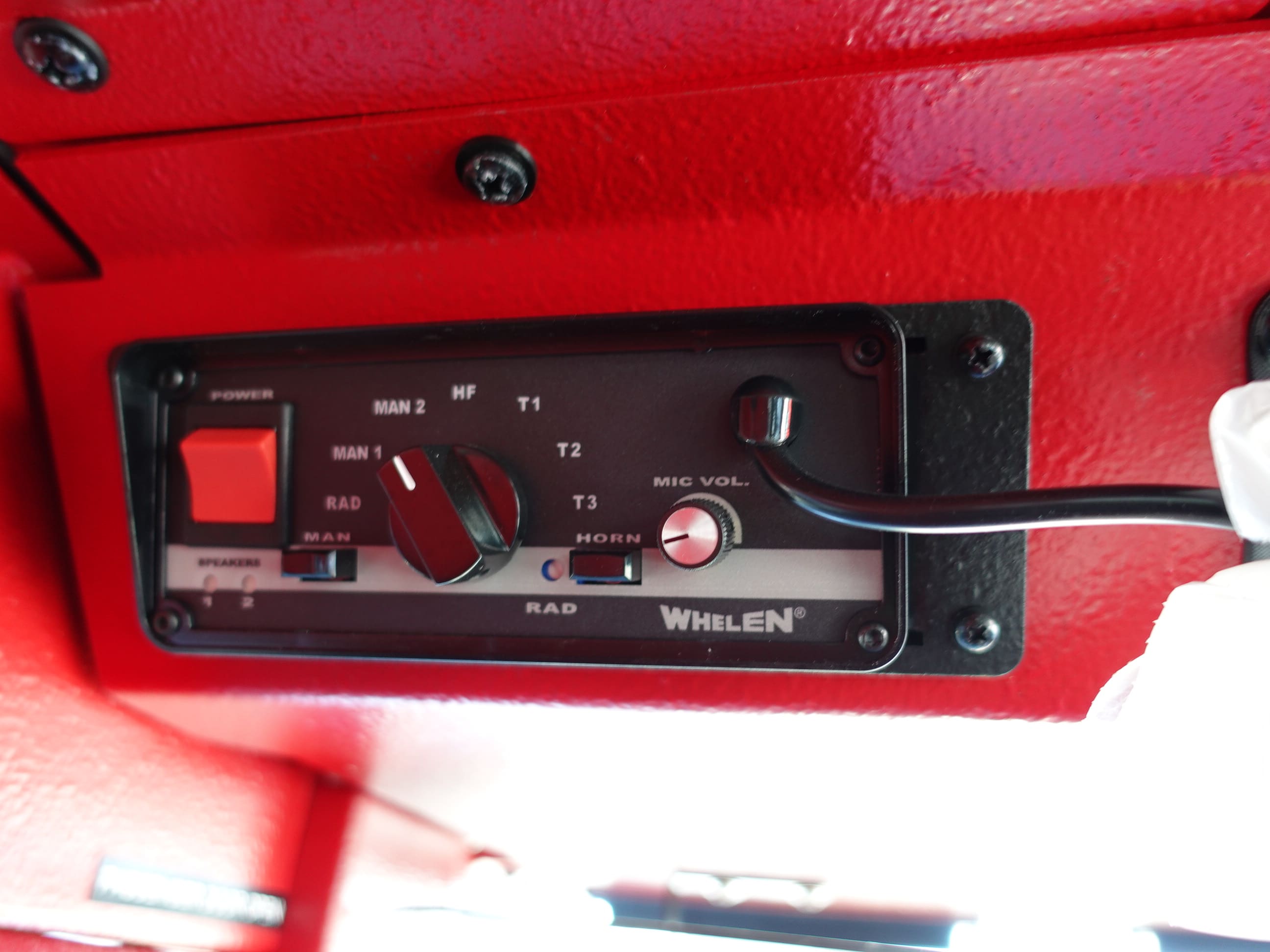

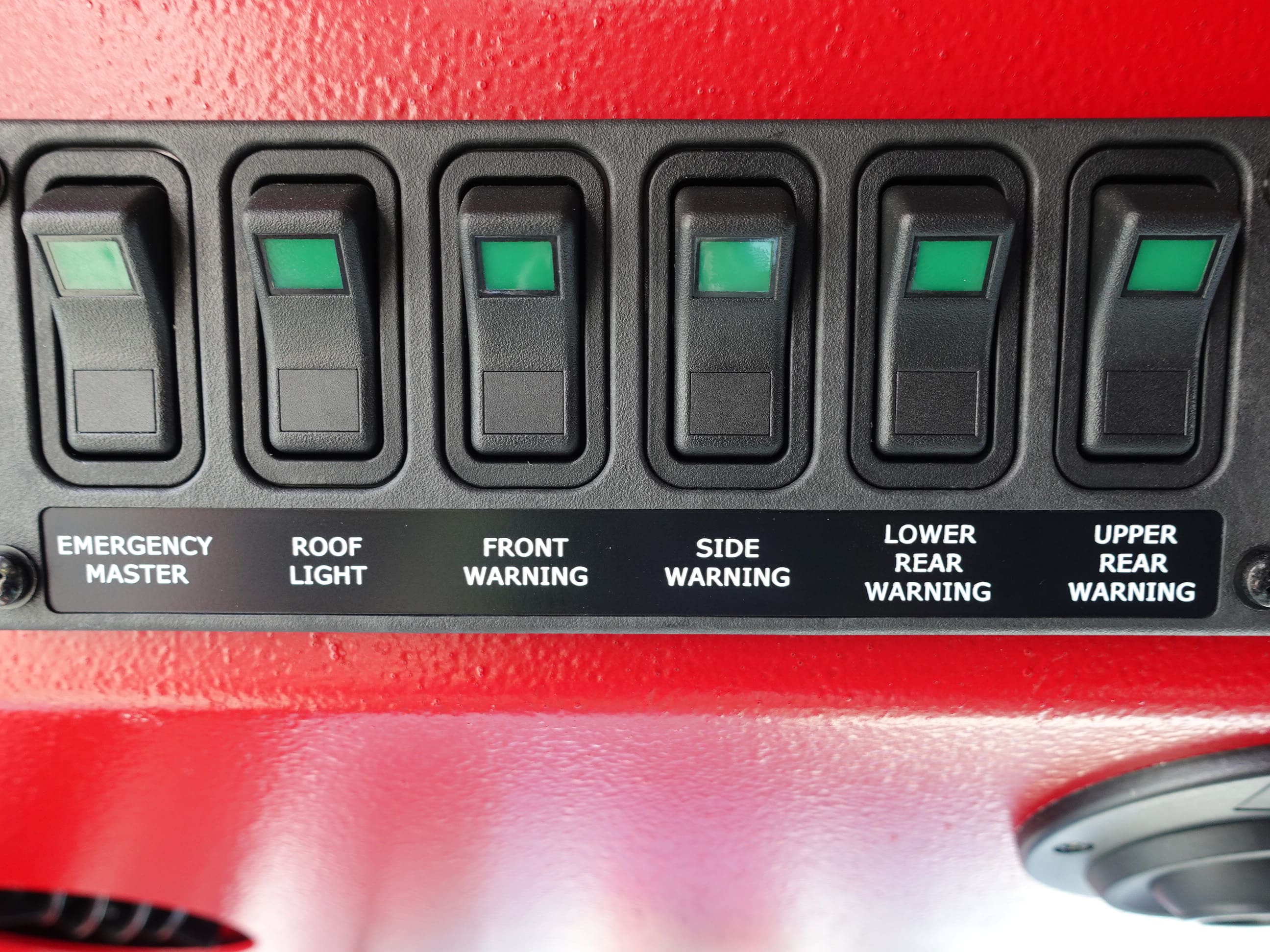

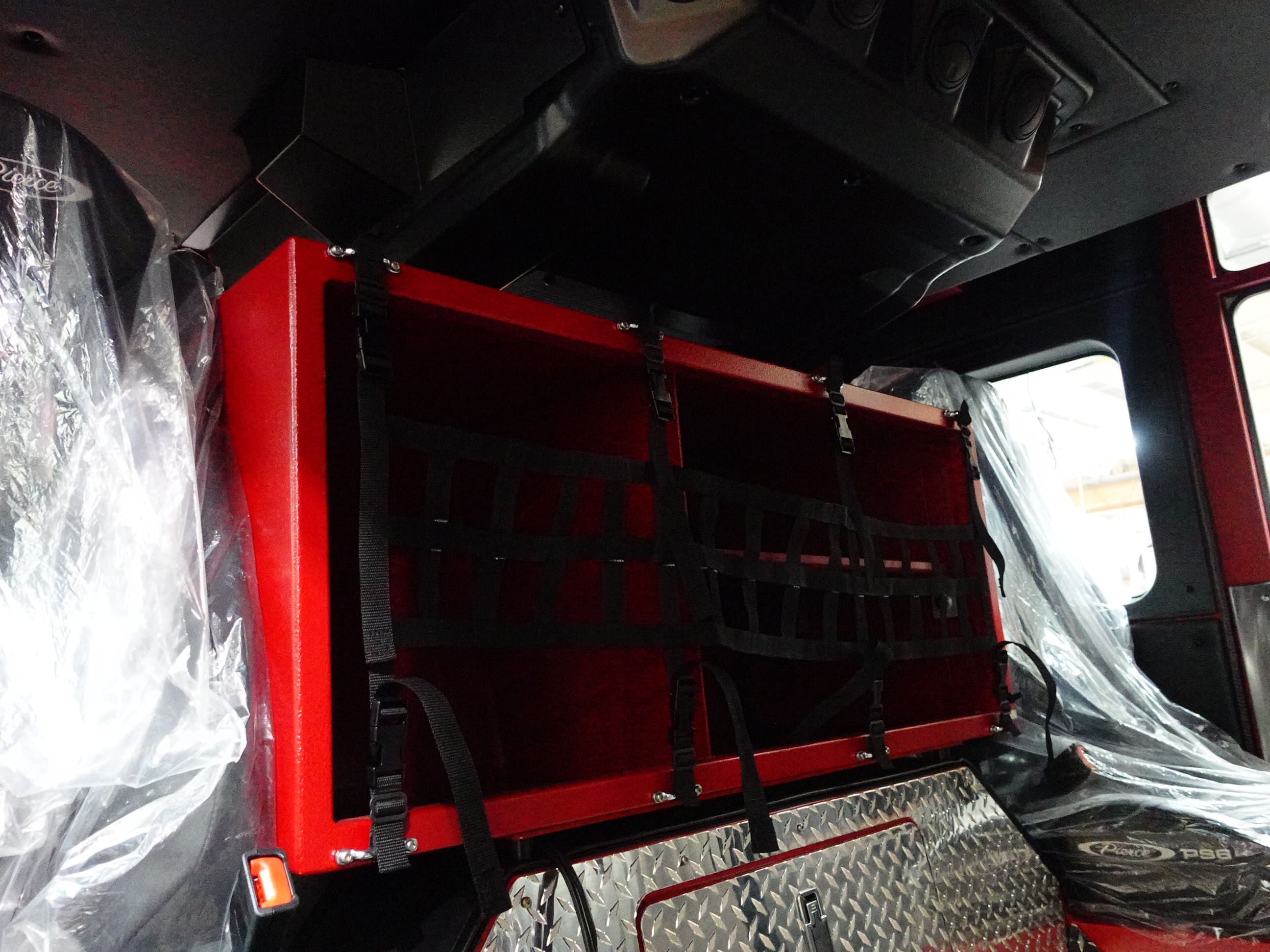

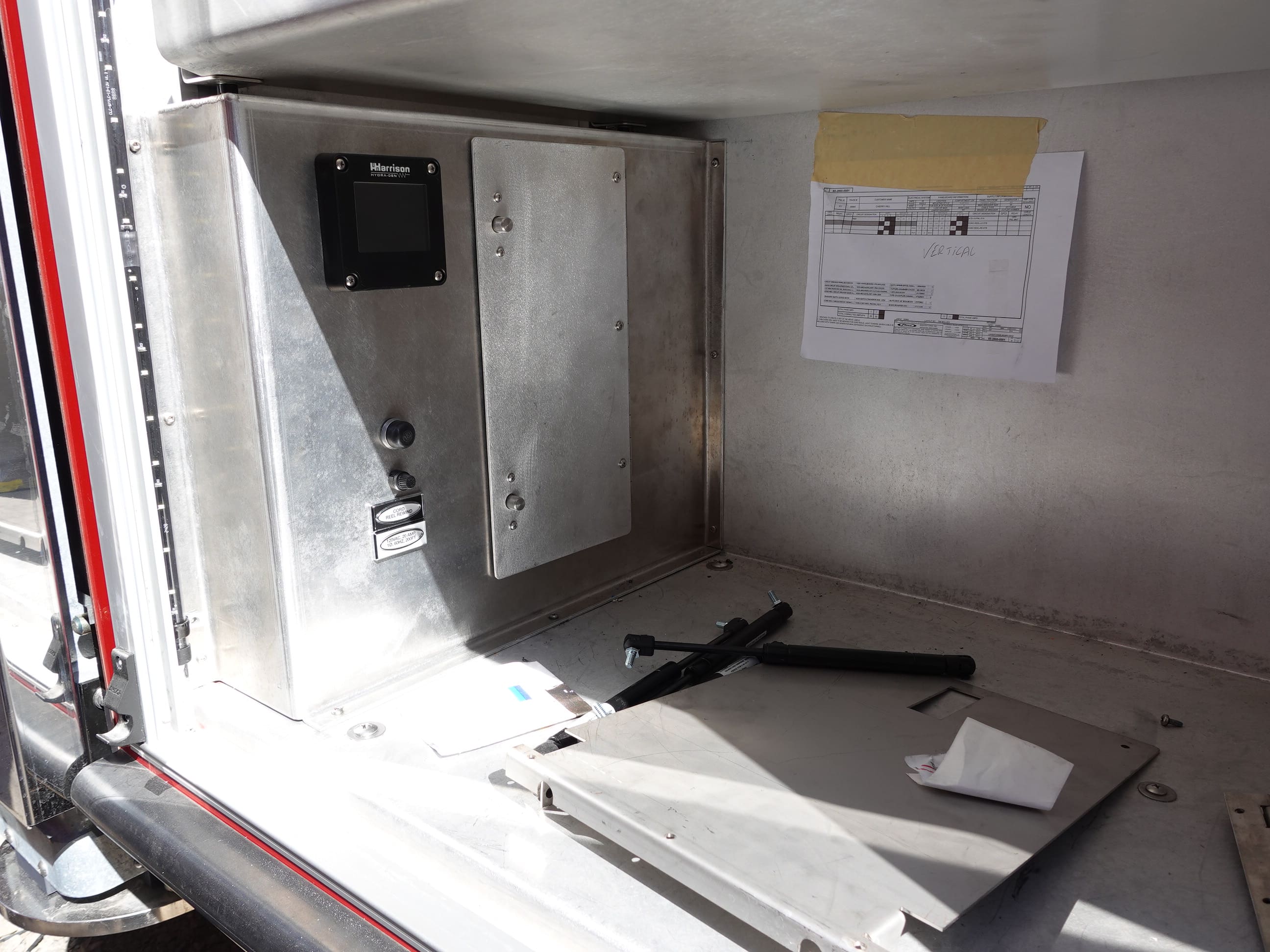

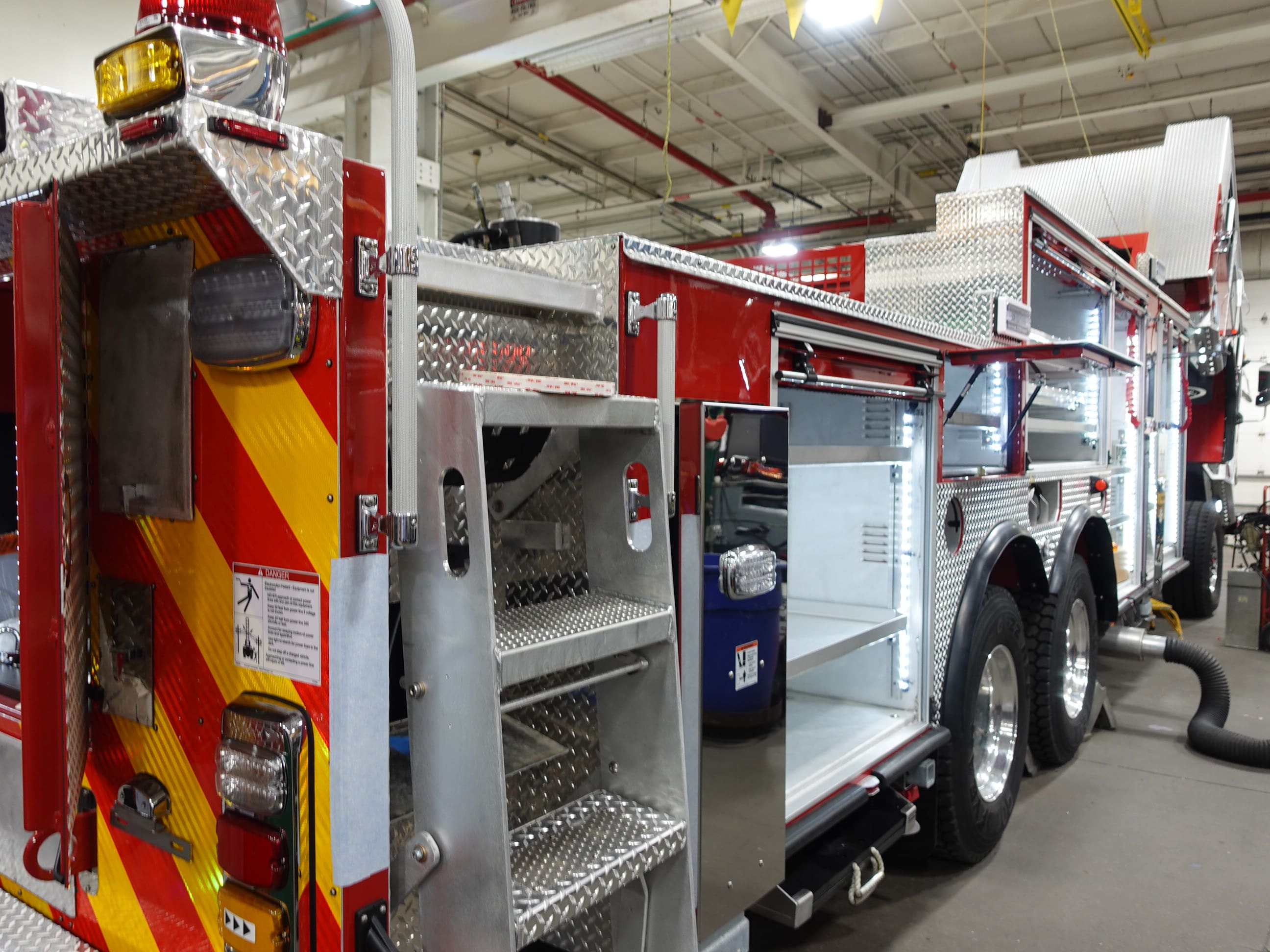

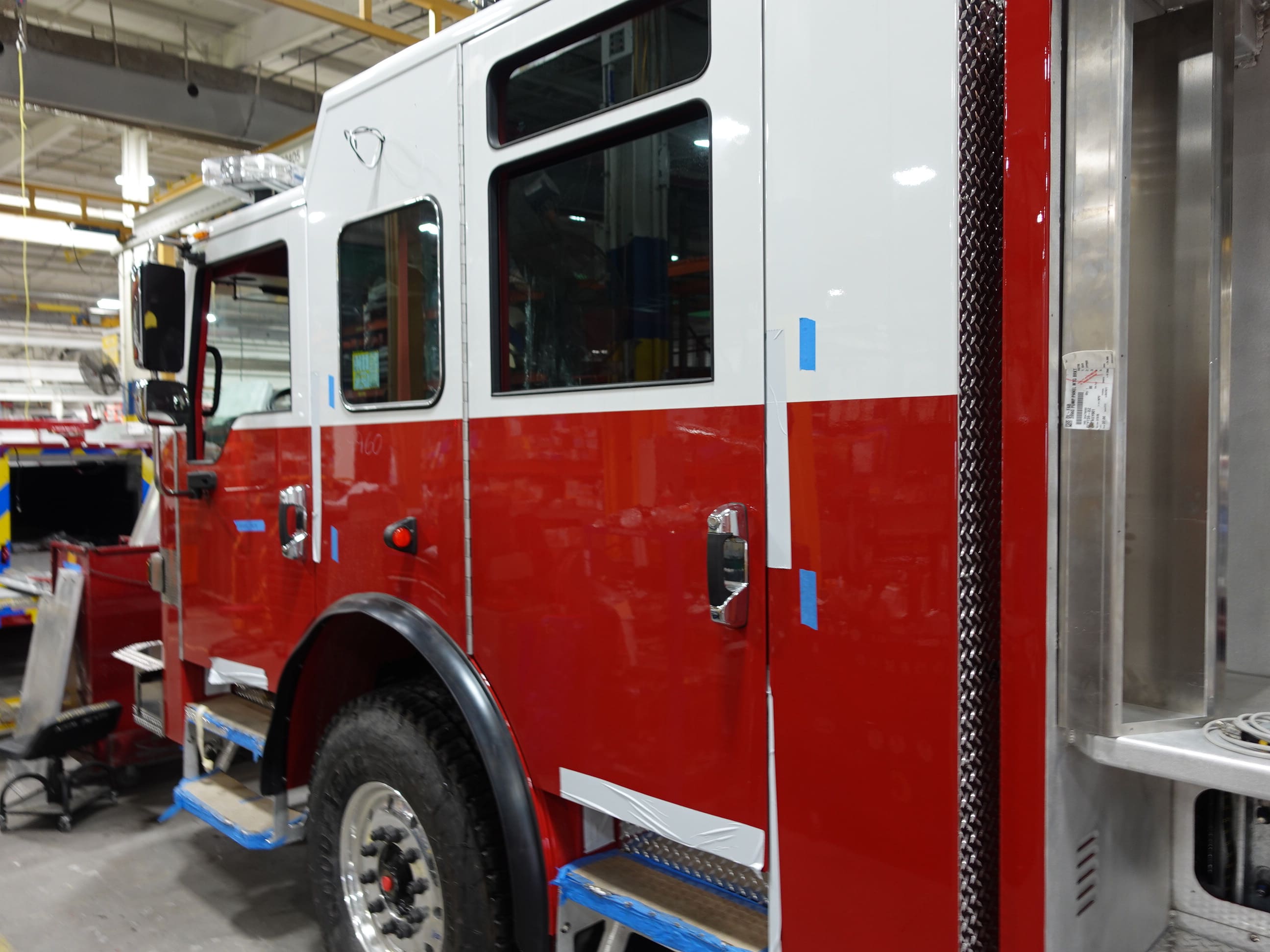

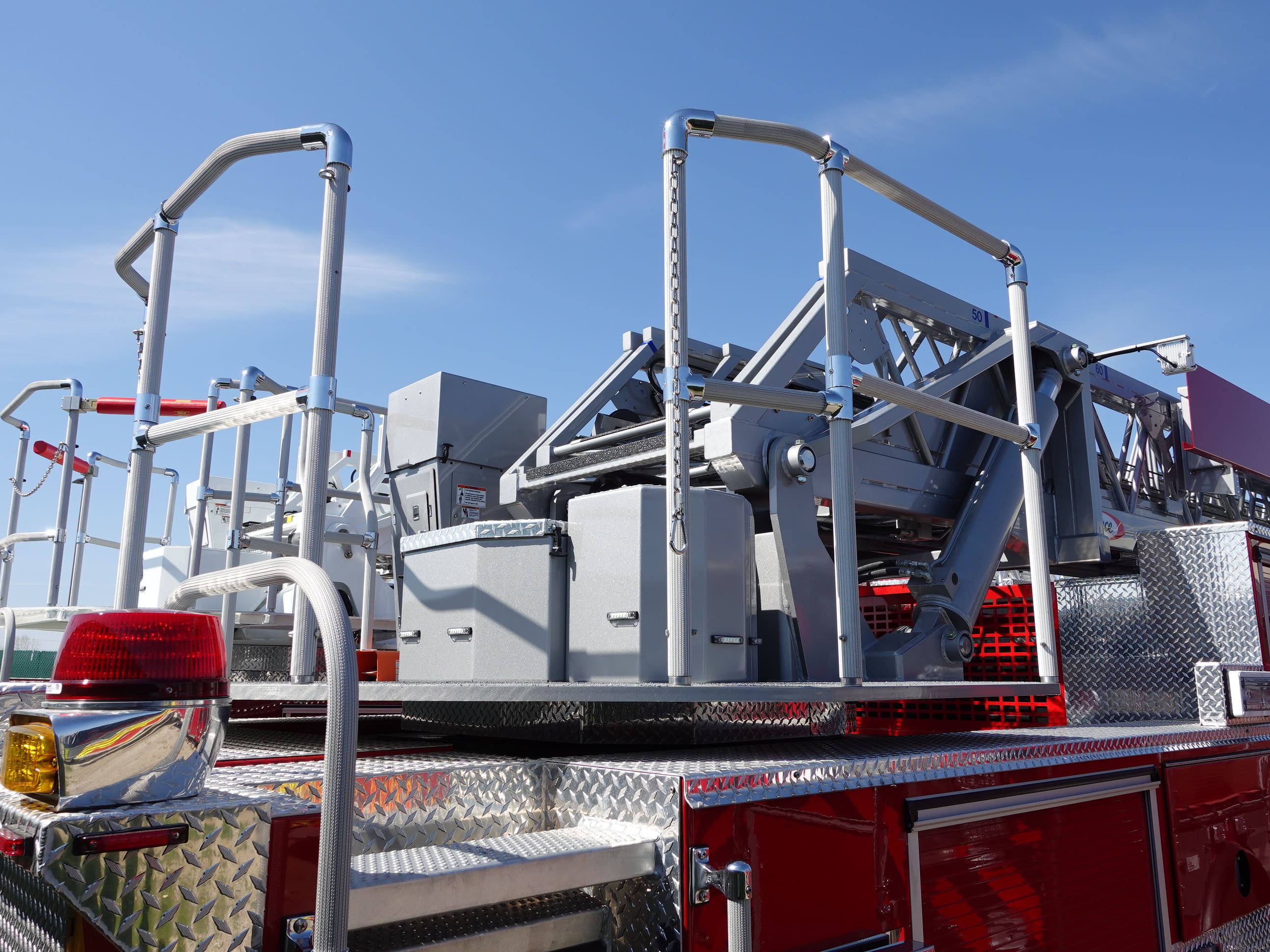

In this report, the apparatus continued testing. When
testing completes it will release to quality and graphics

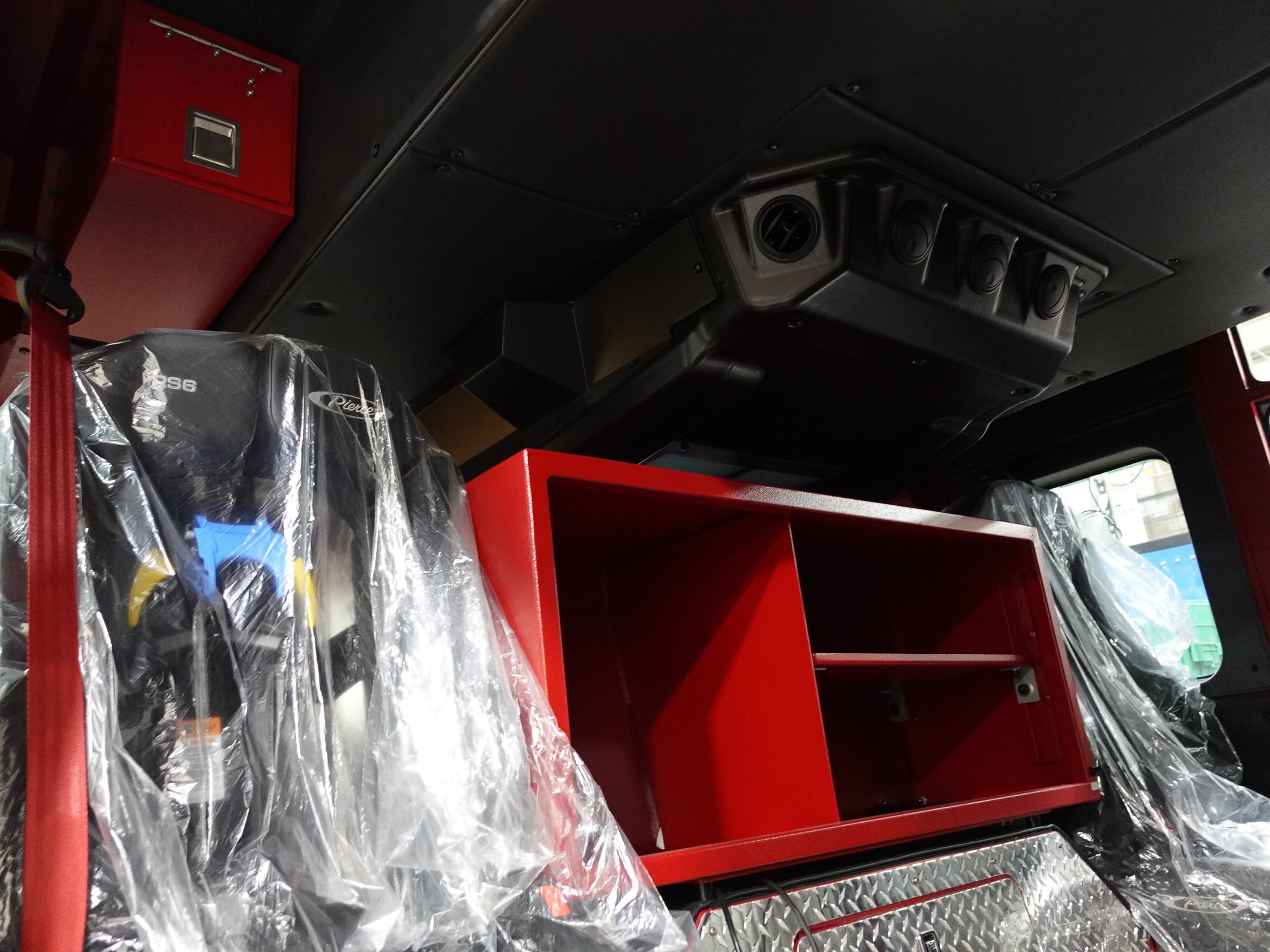

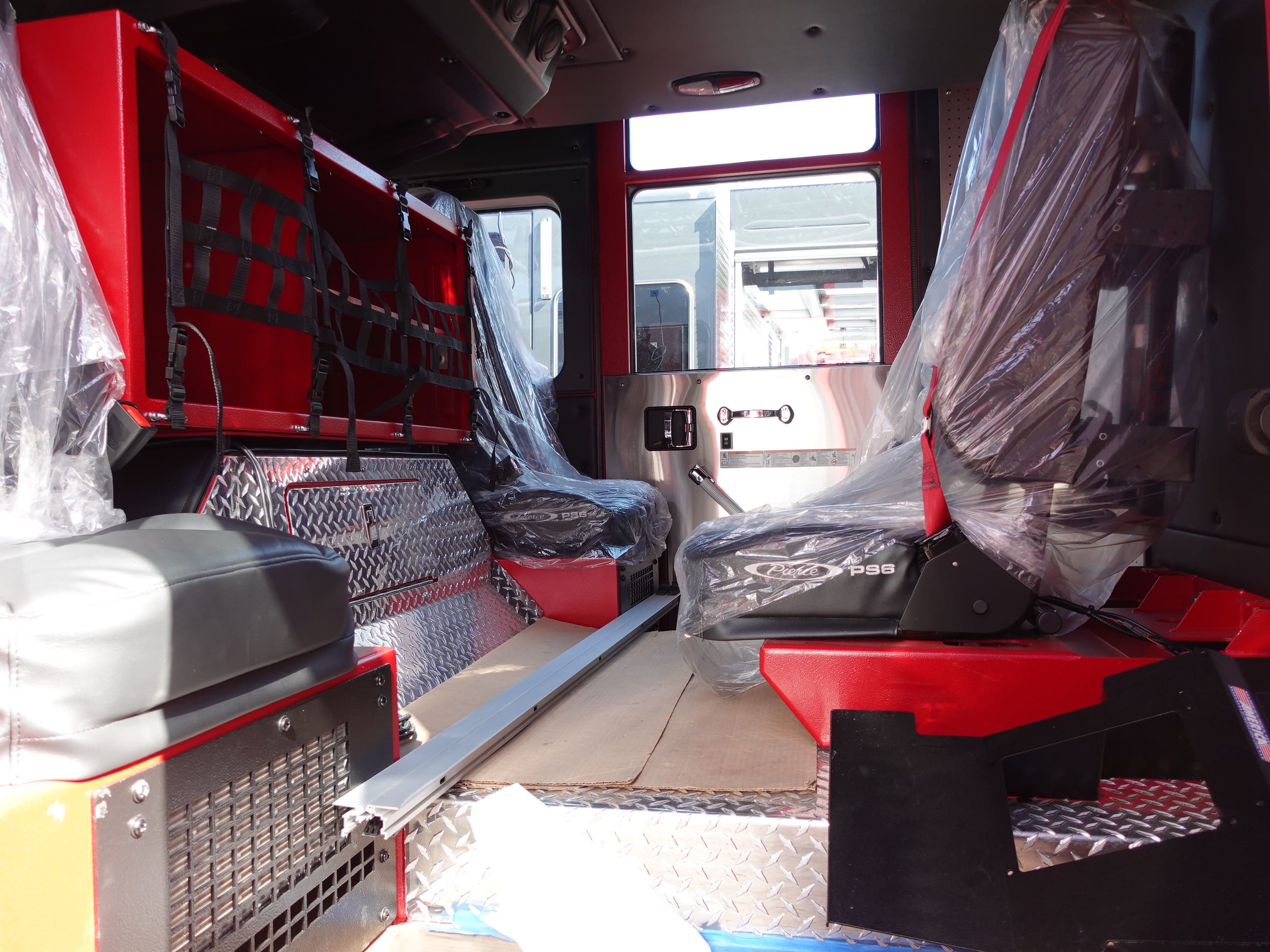

where any remaining content will be applied. Once
finished it will be made ready for the customer

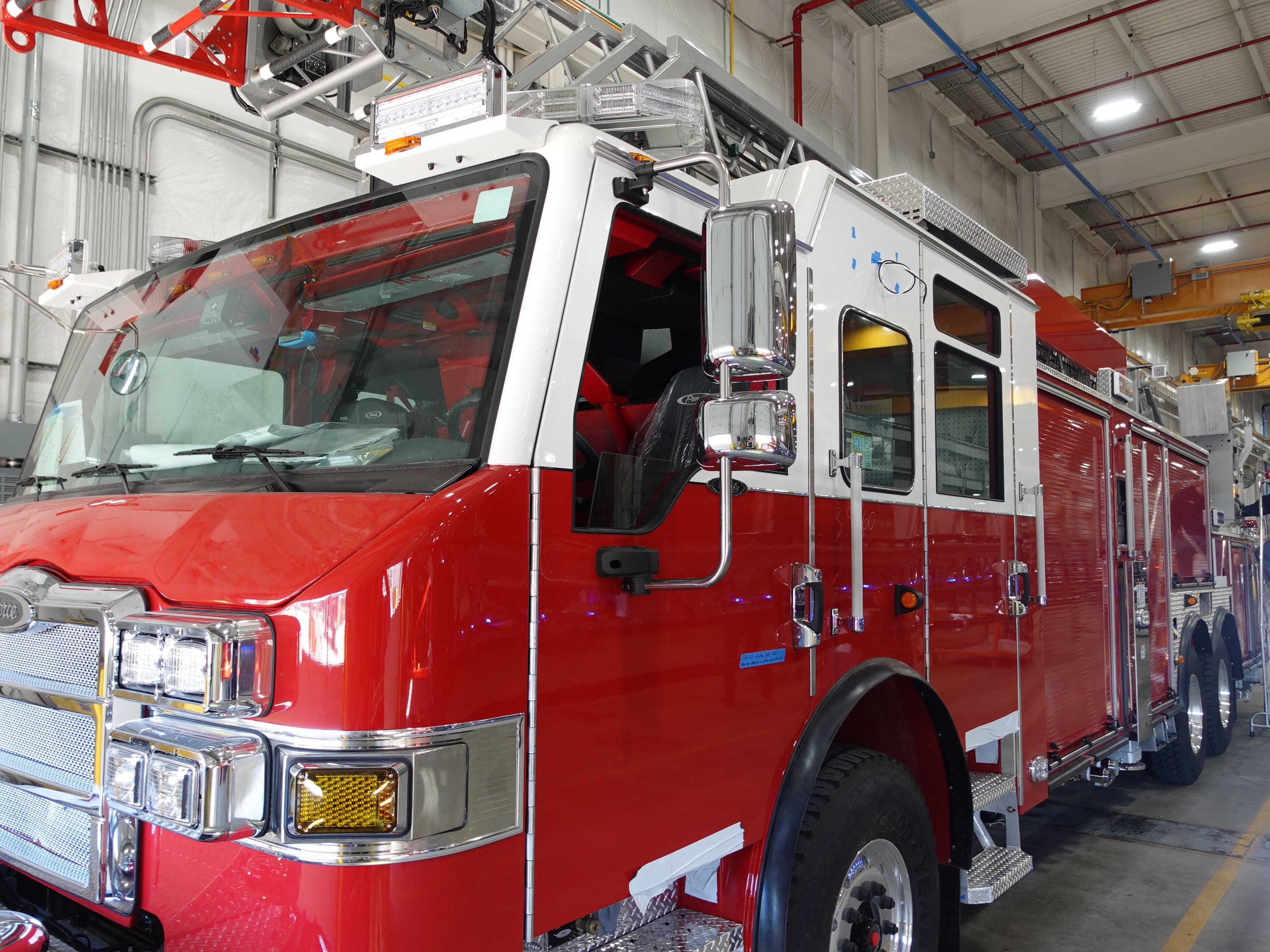

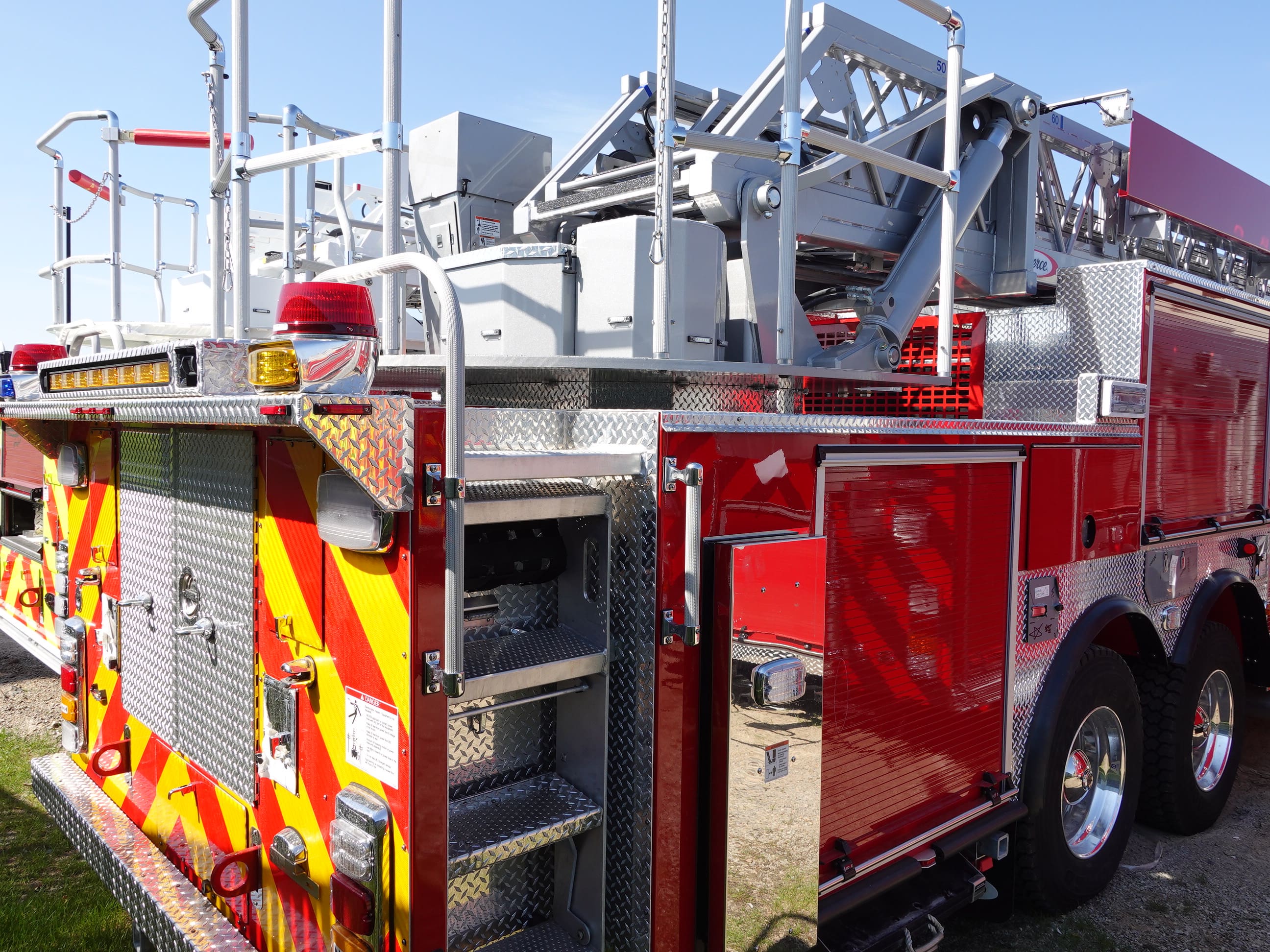

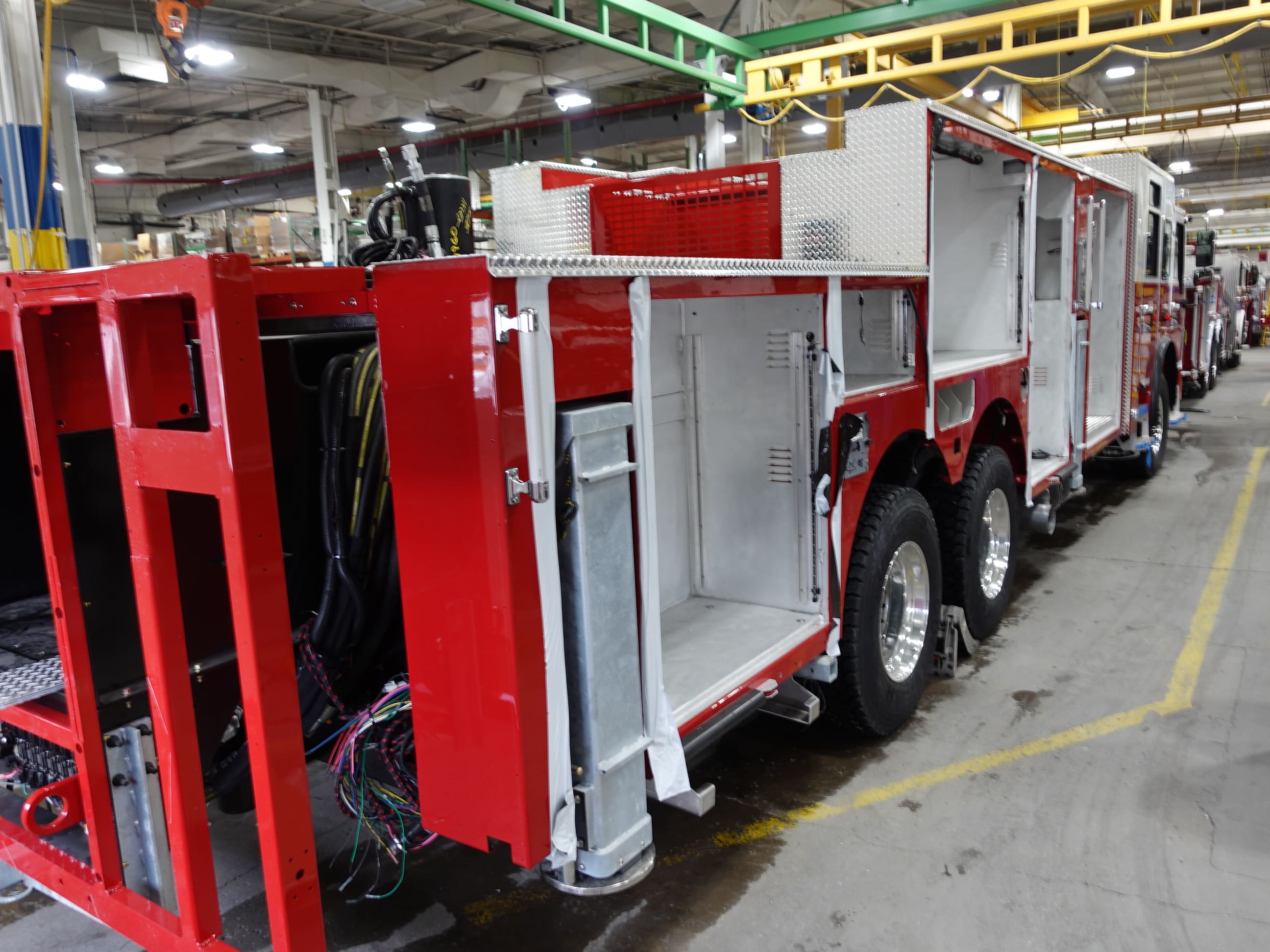

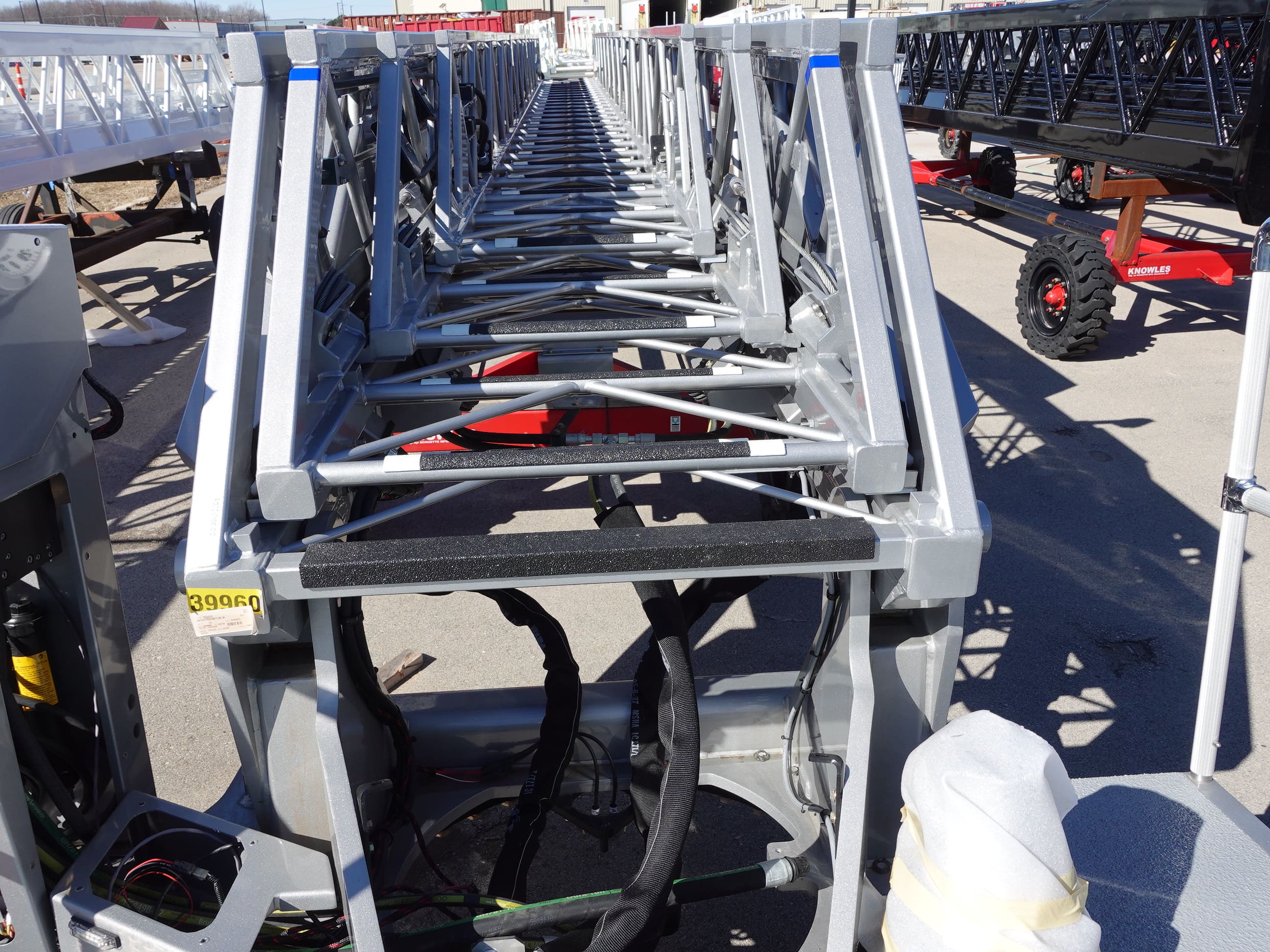

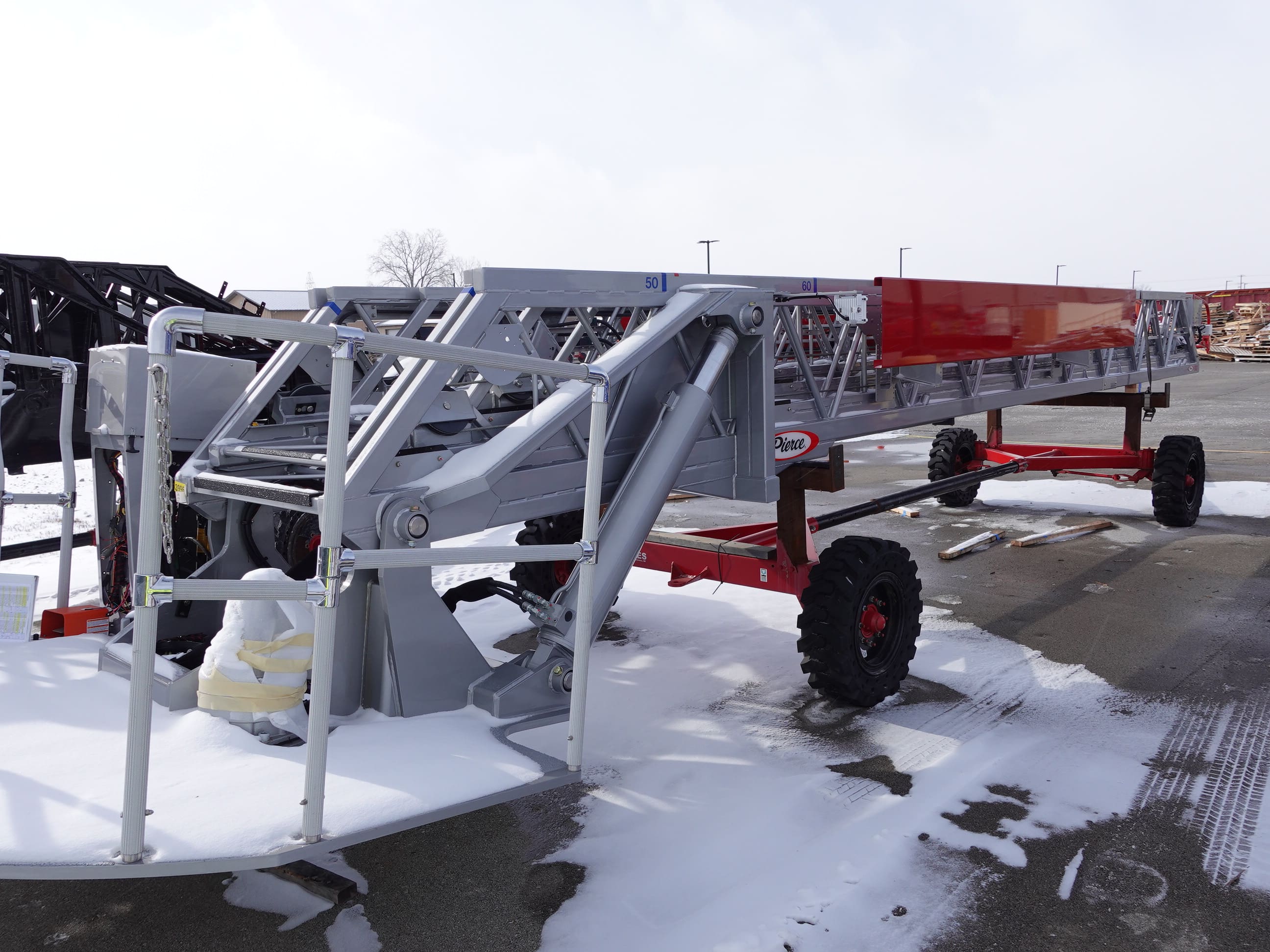

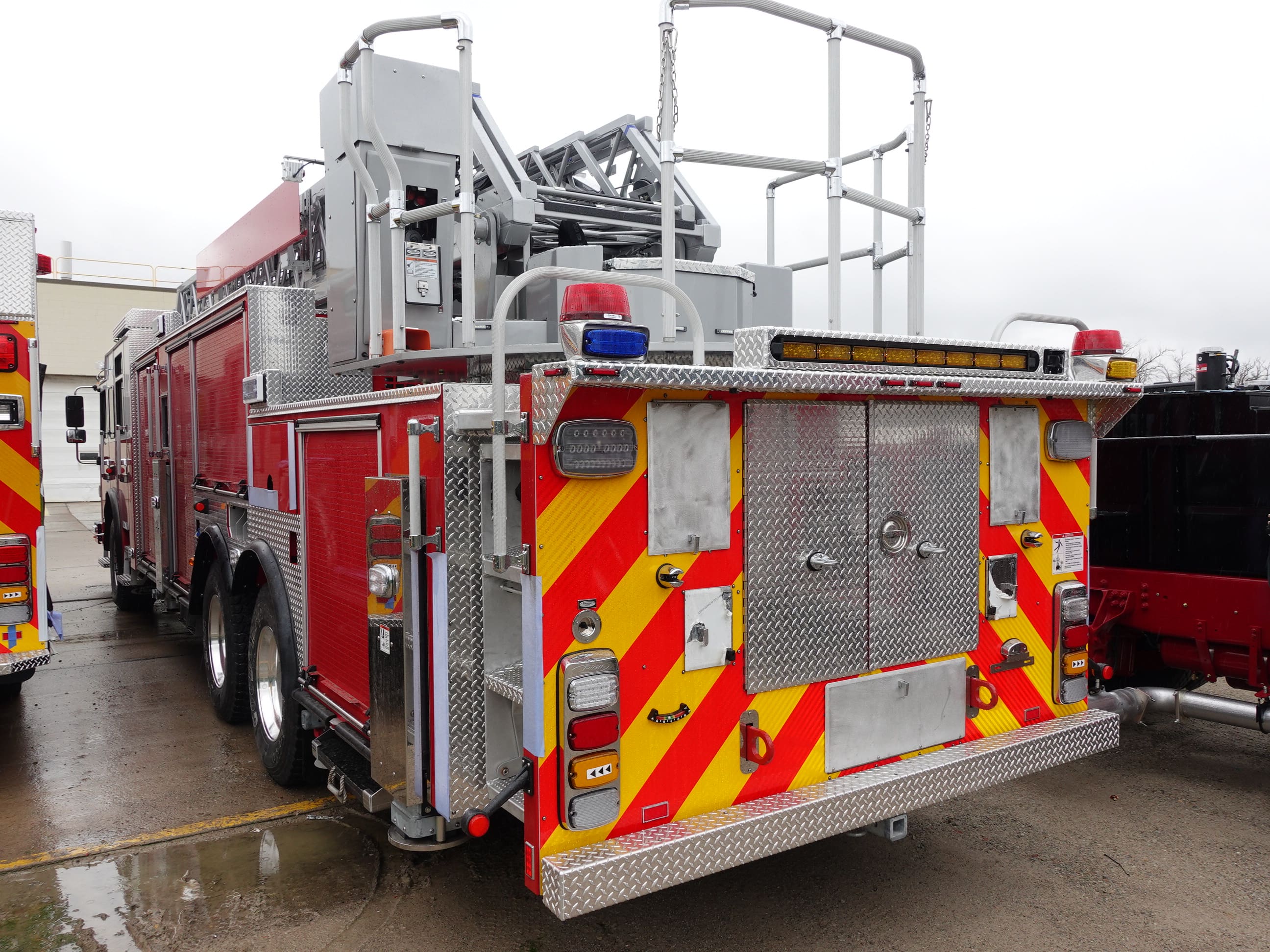

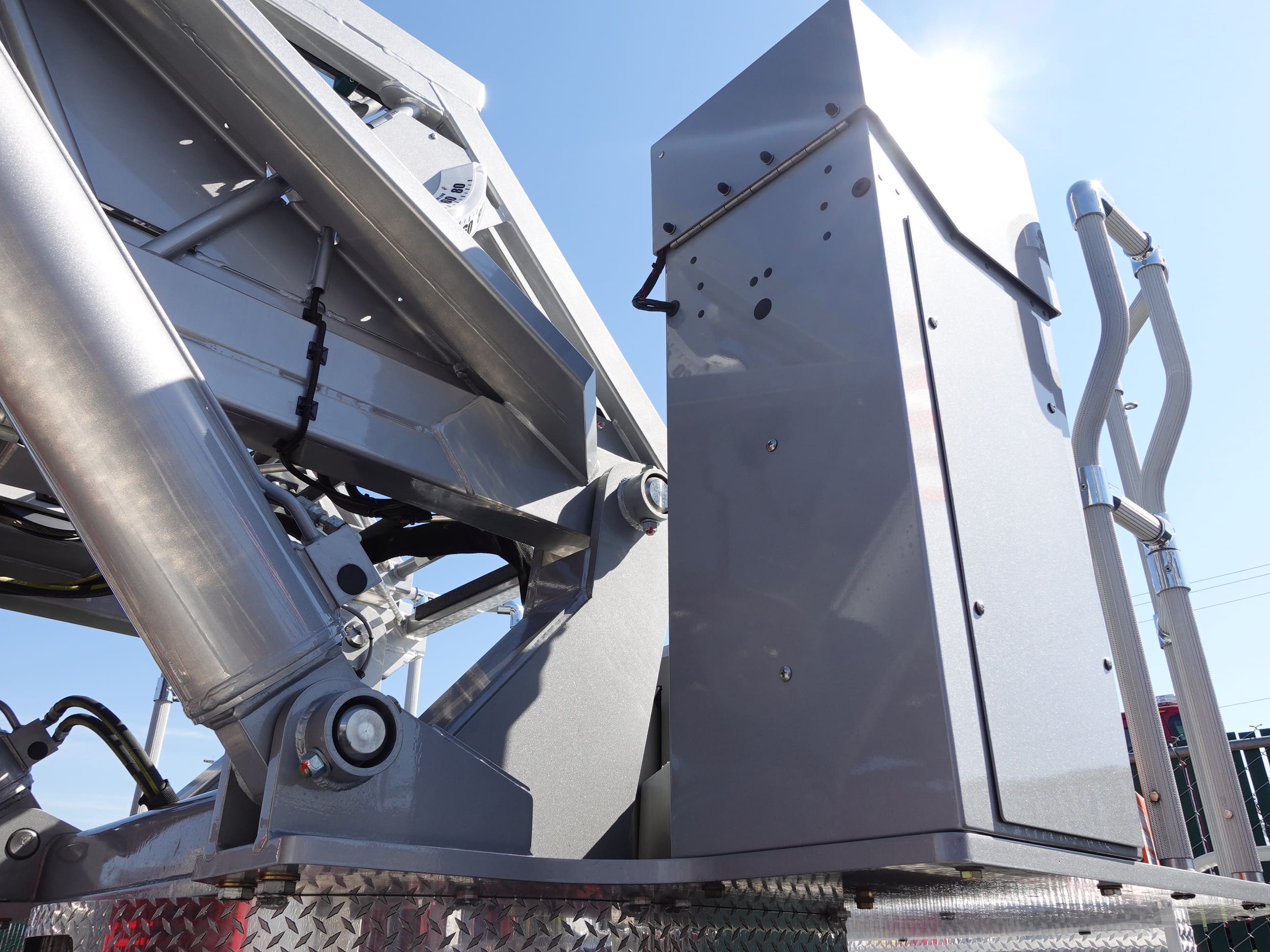

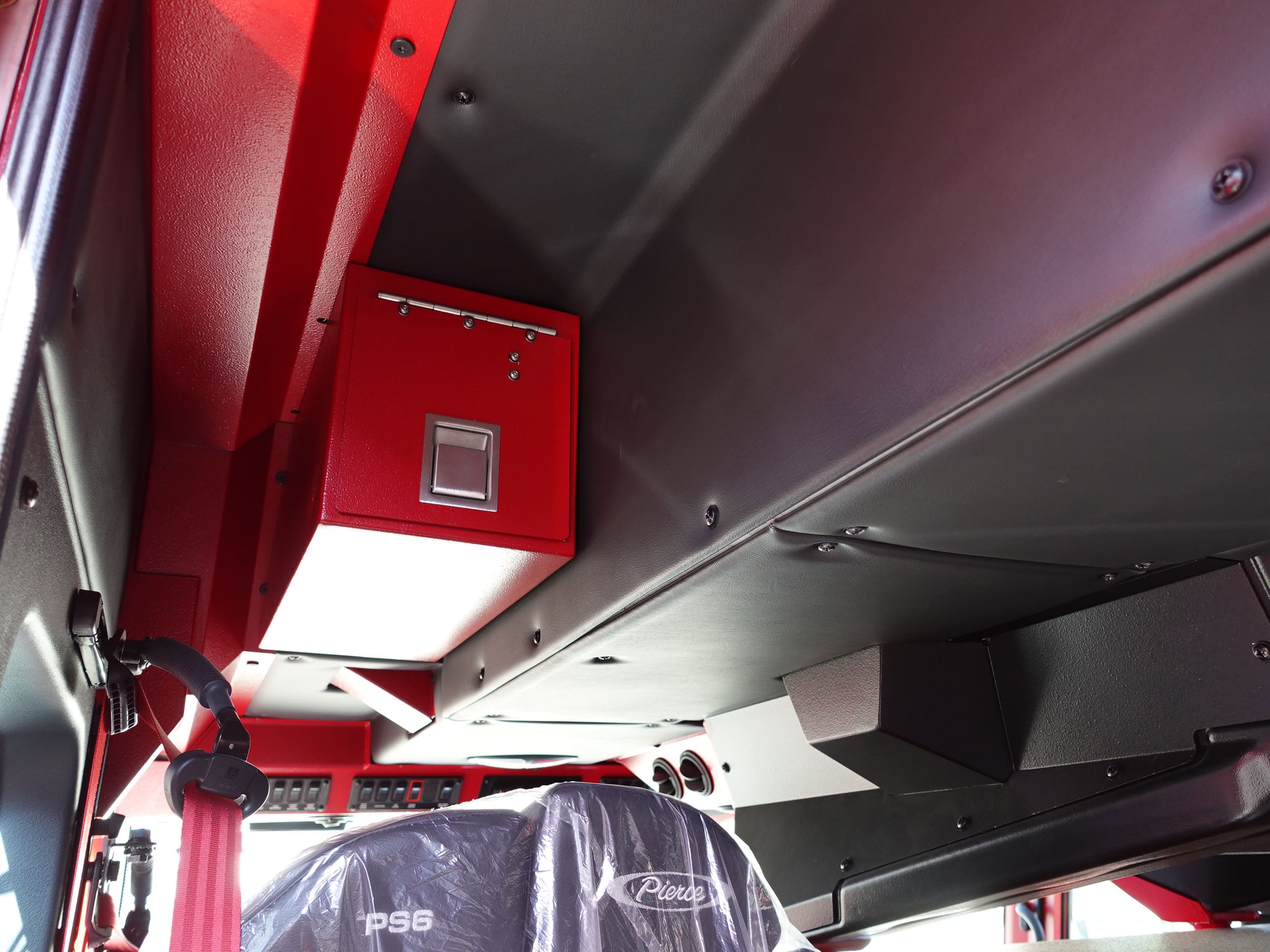

acceptance inspection. This is the last scheduled report.

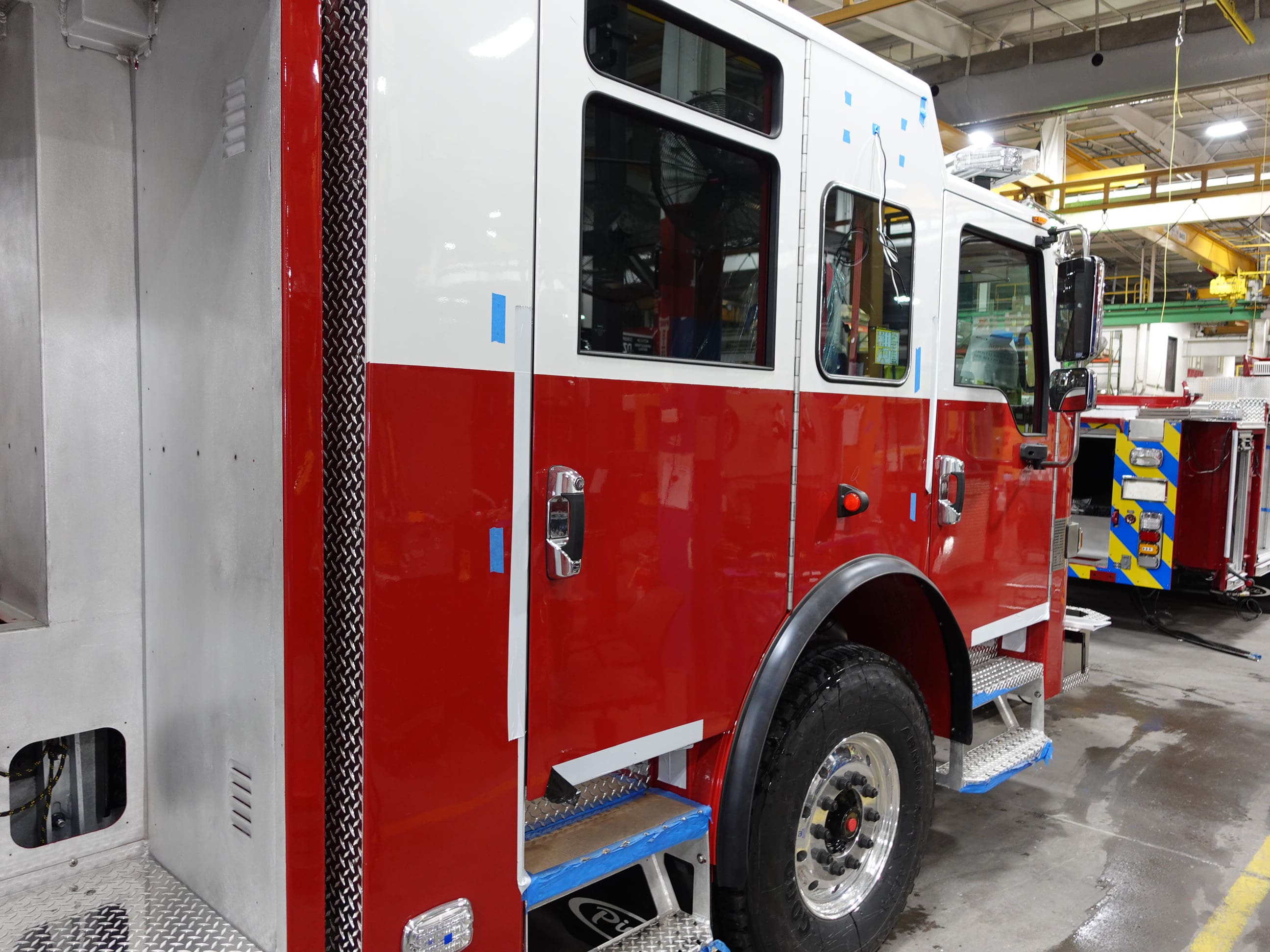

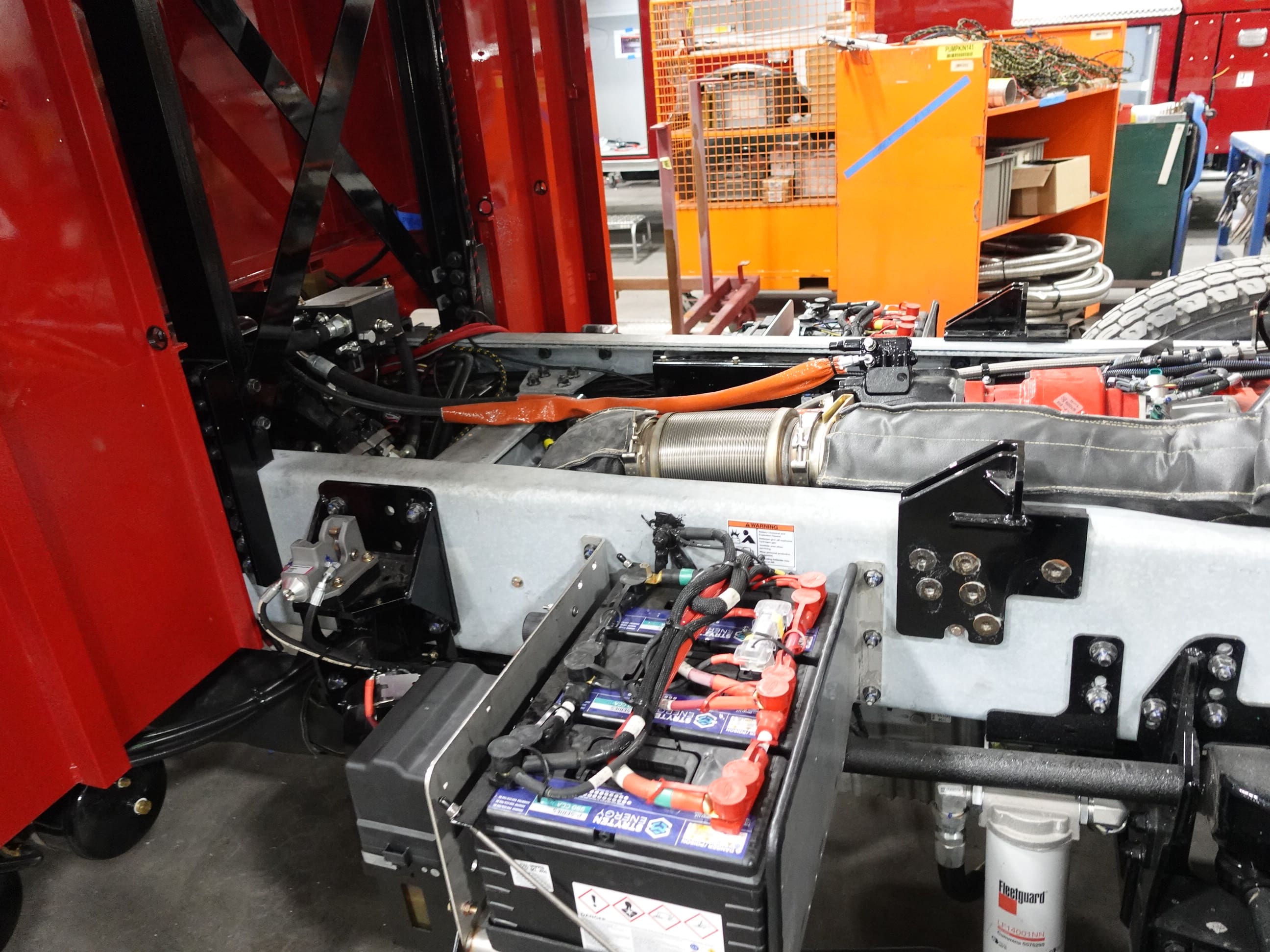

04-17-26

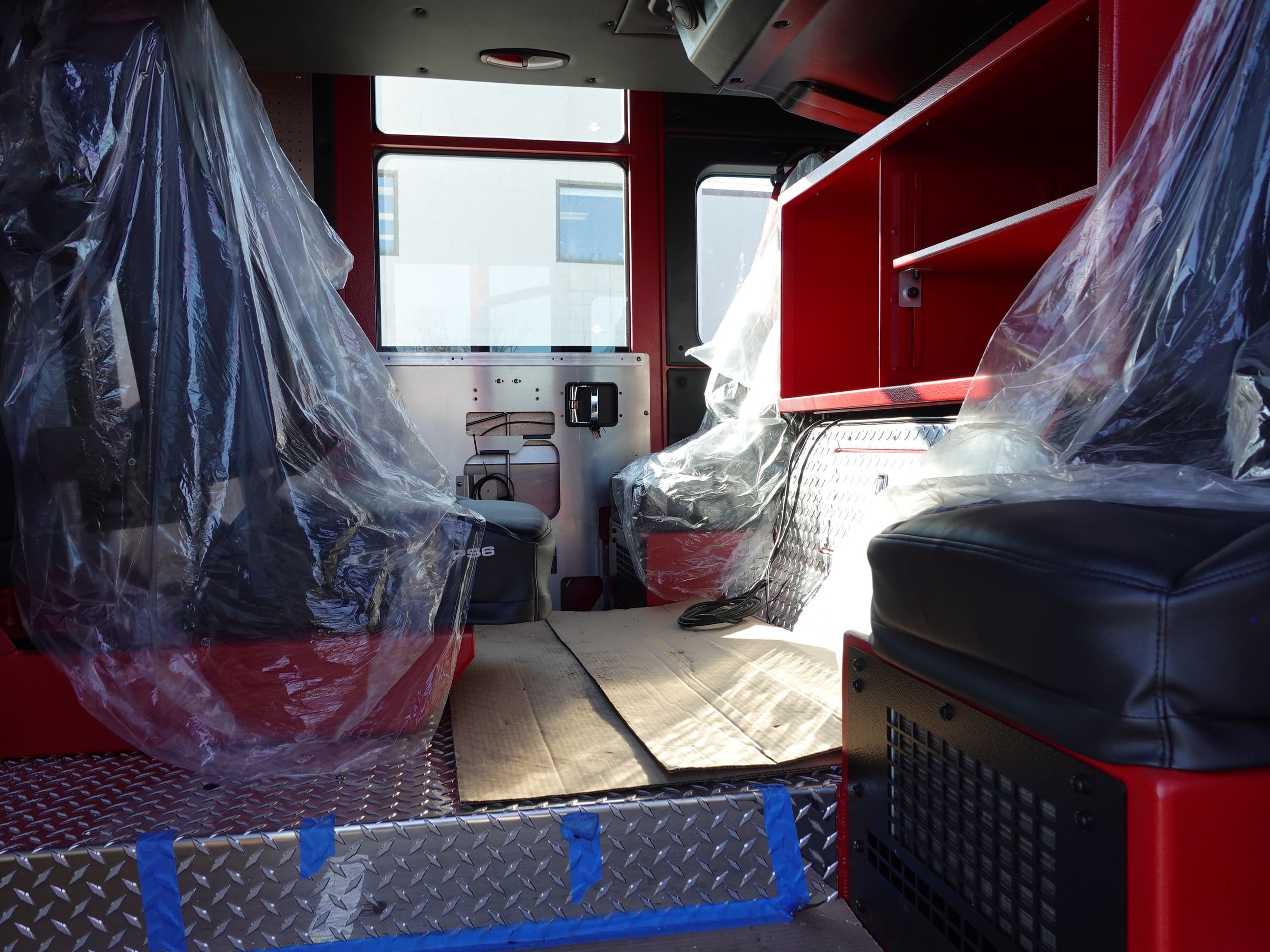

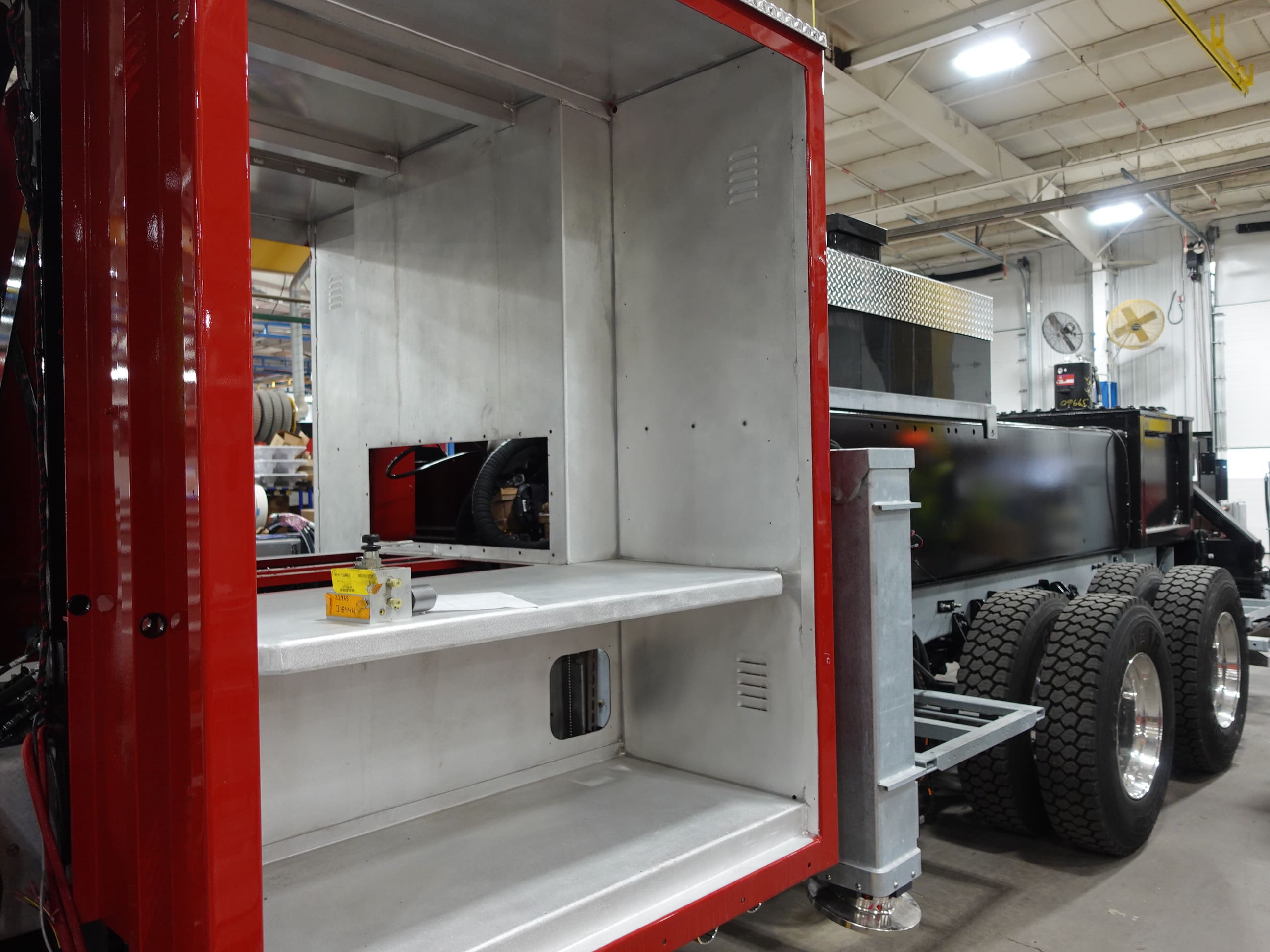

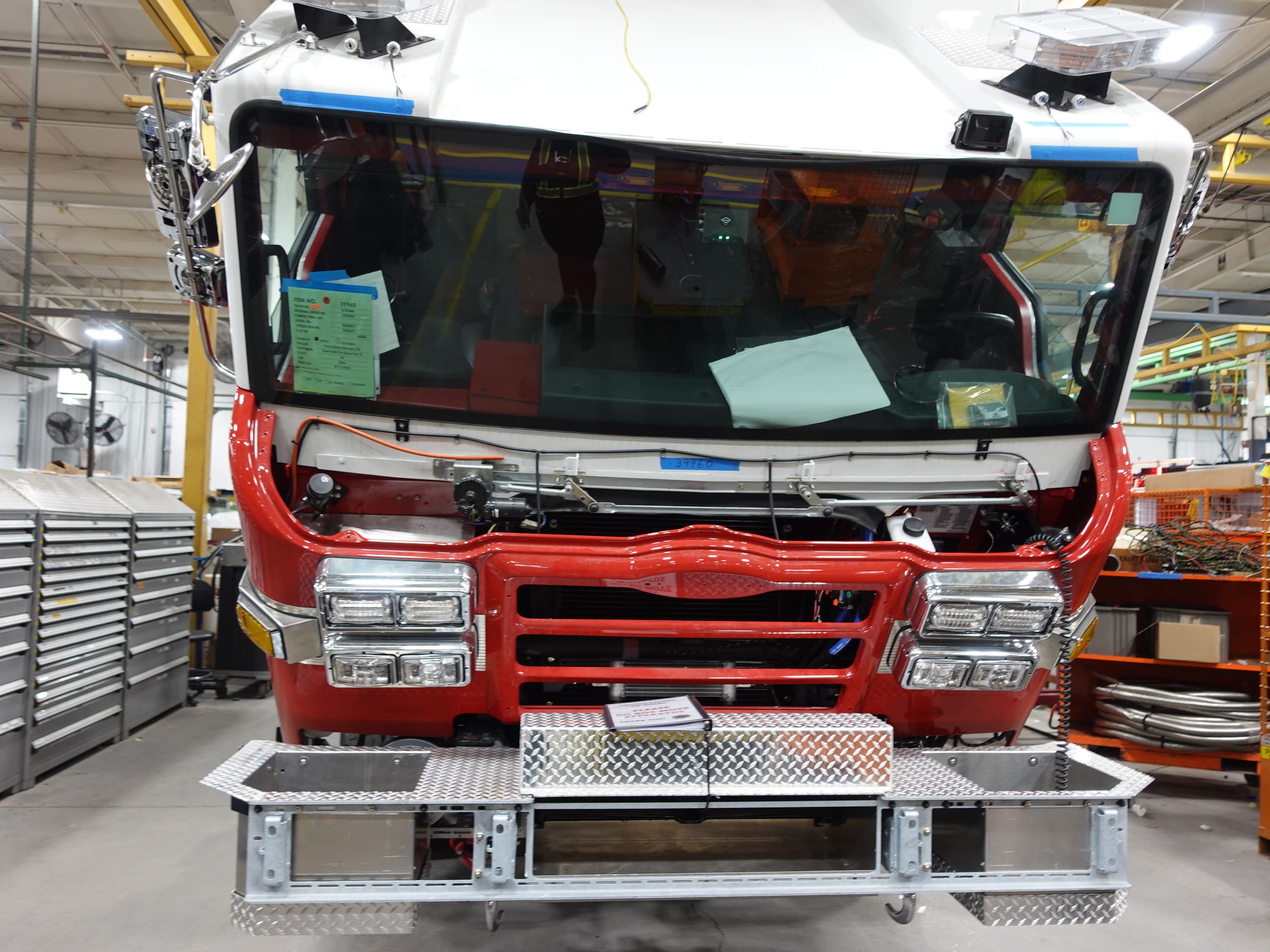

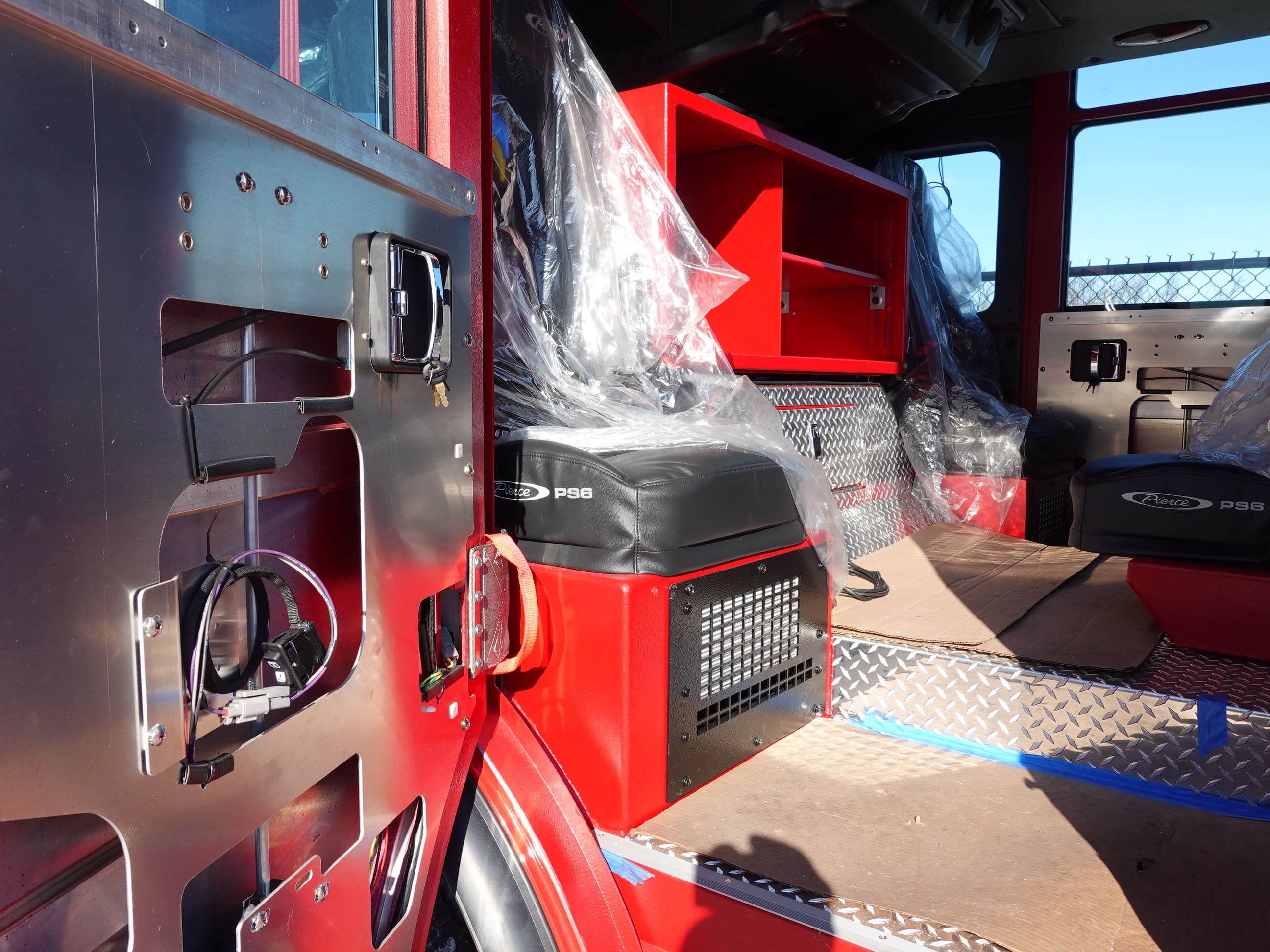

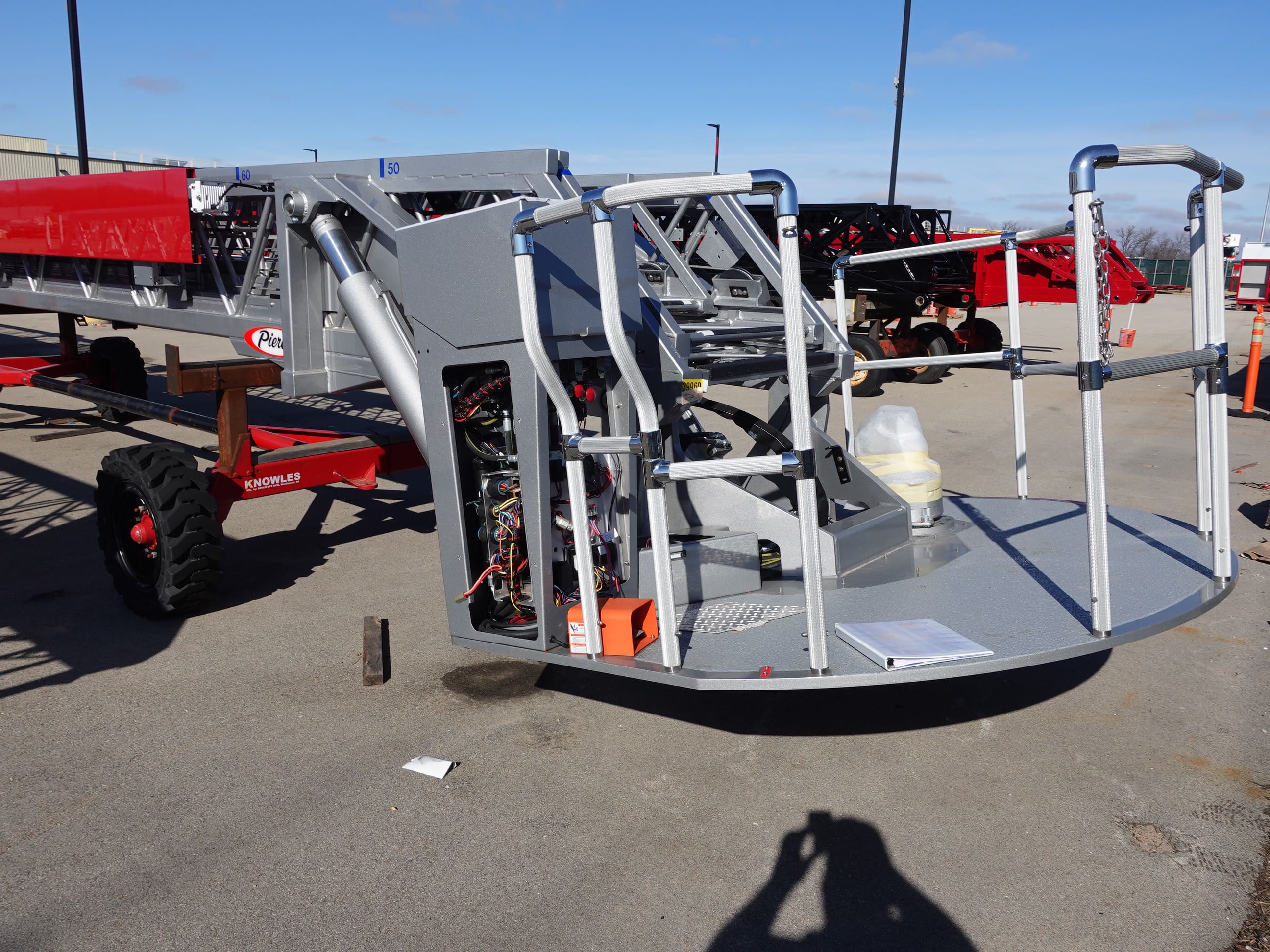

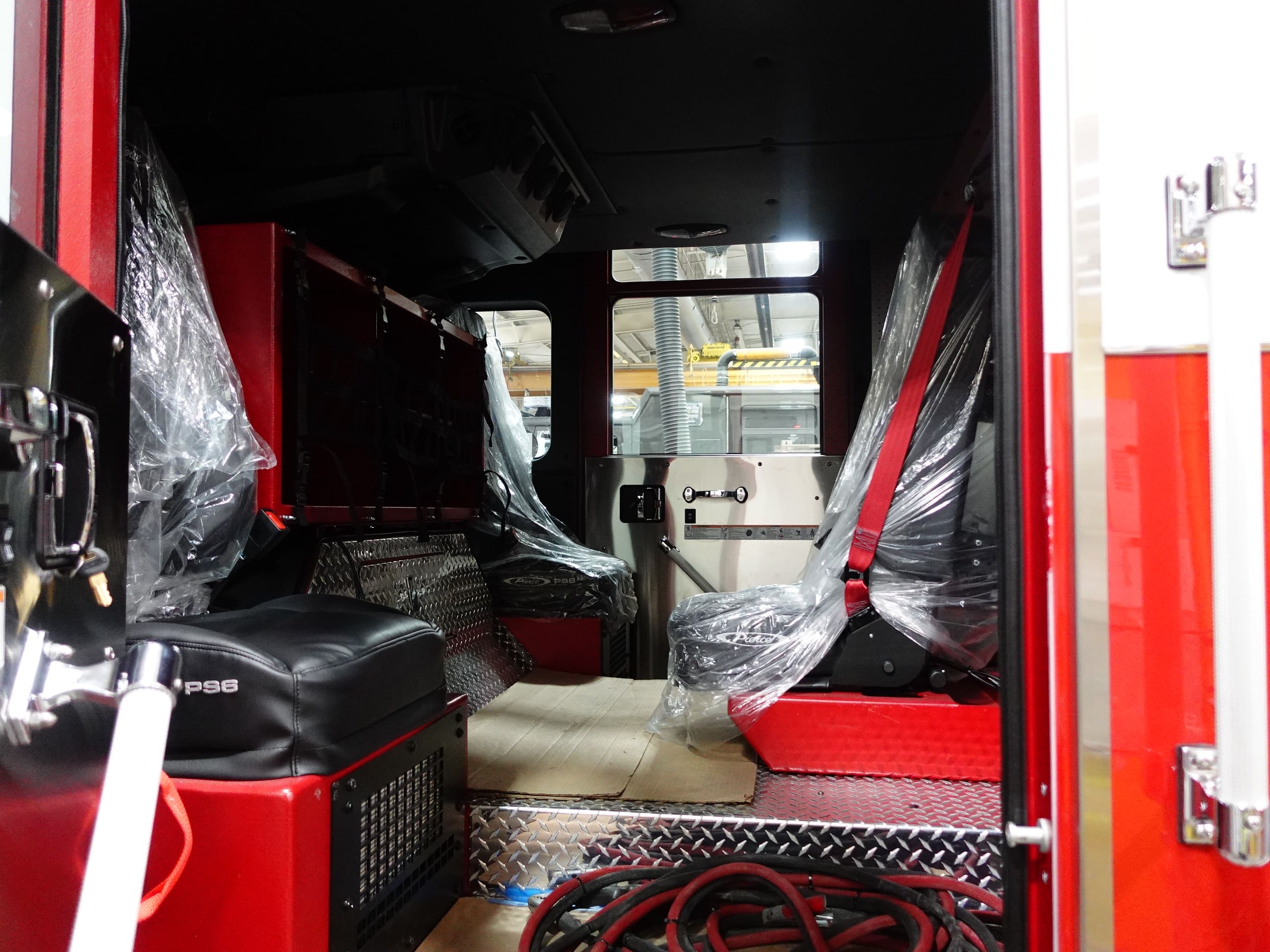

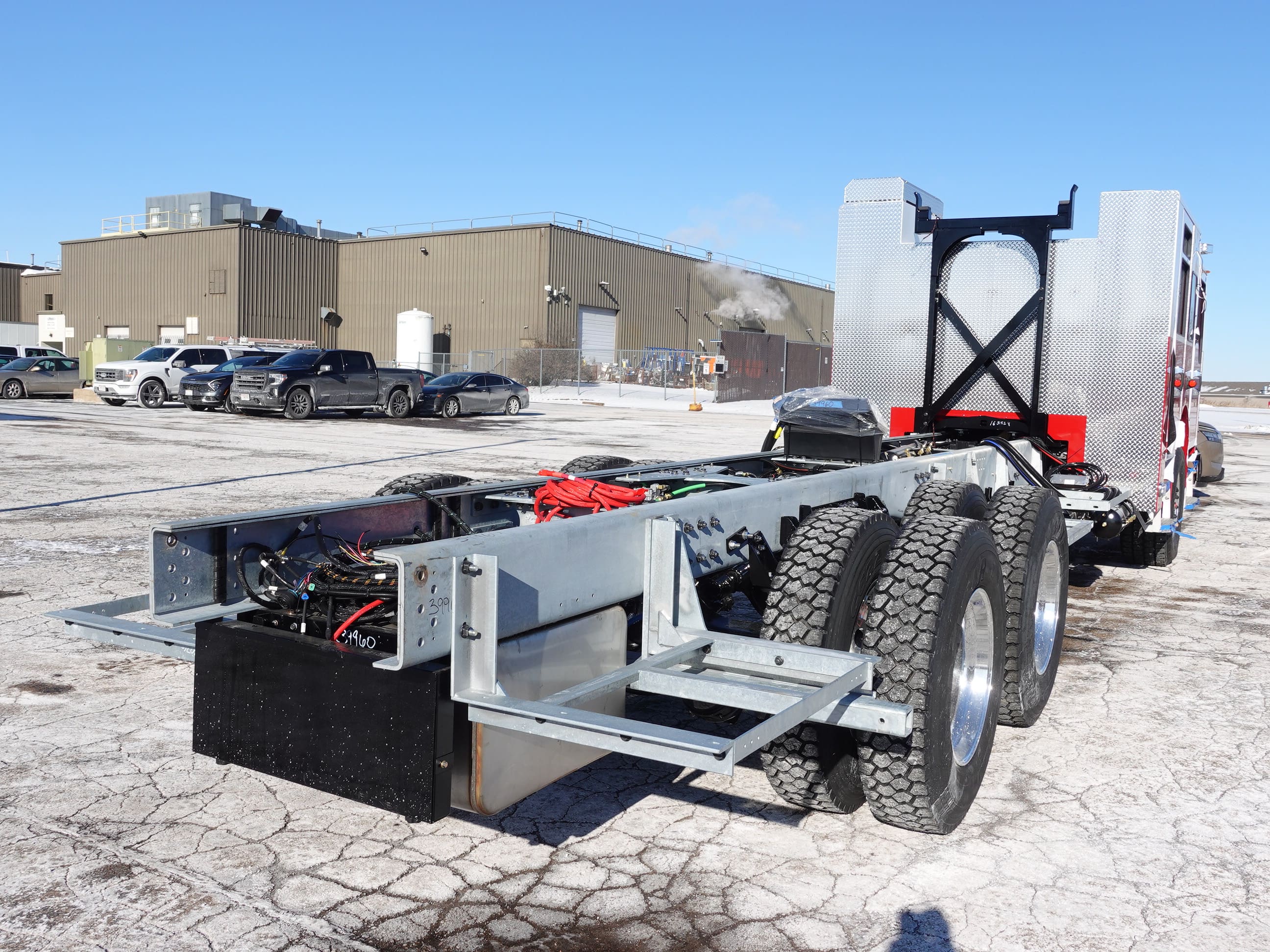

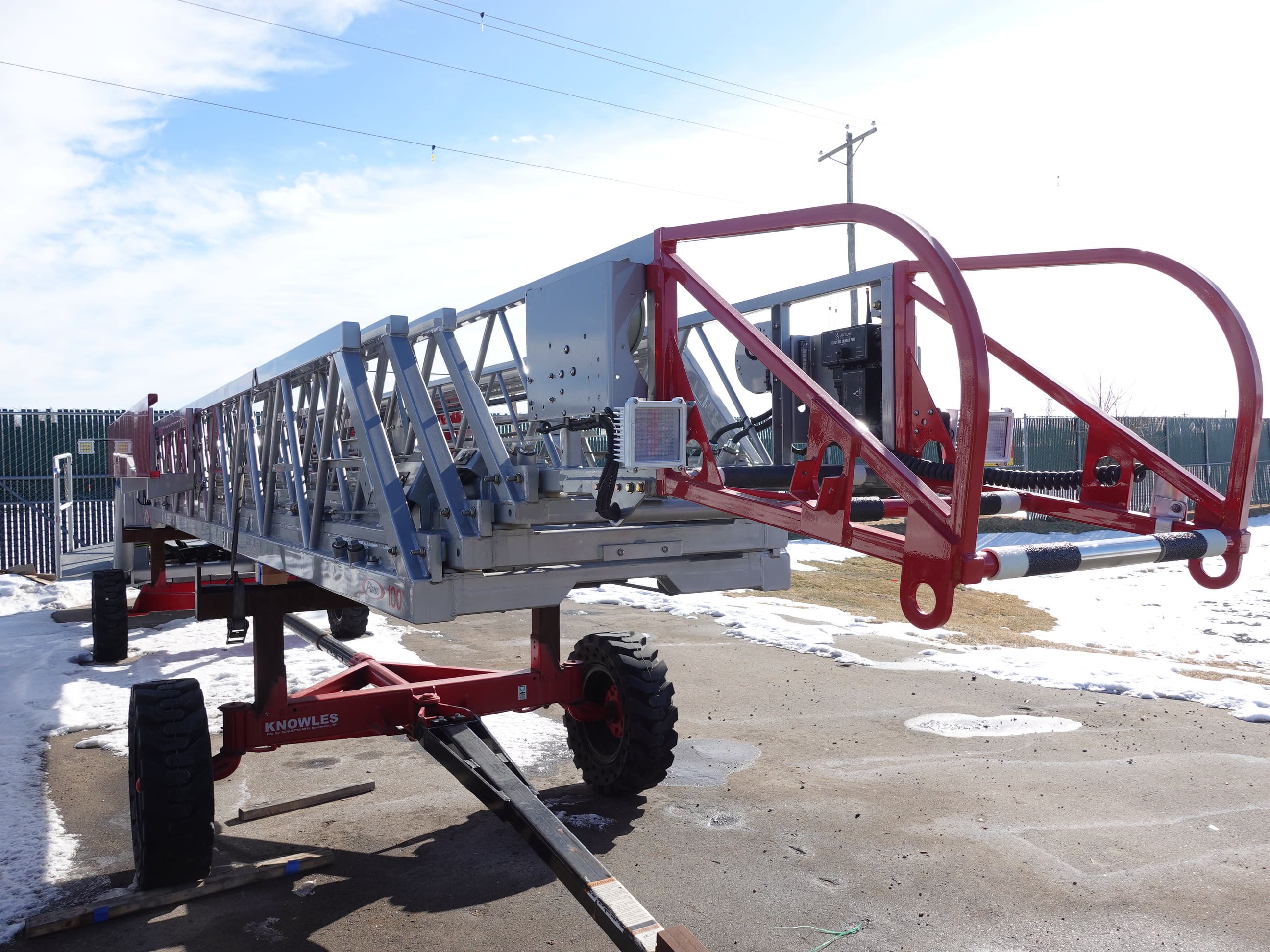

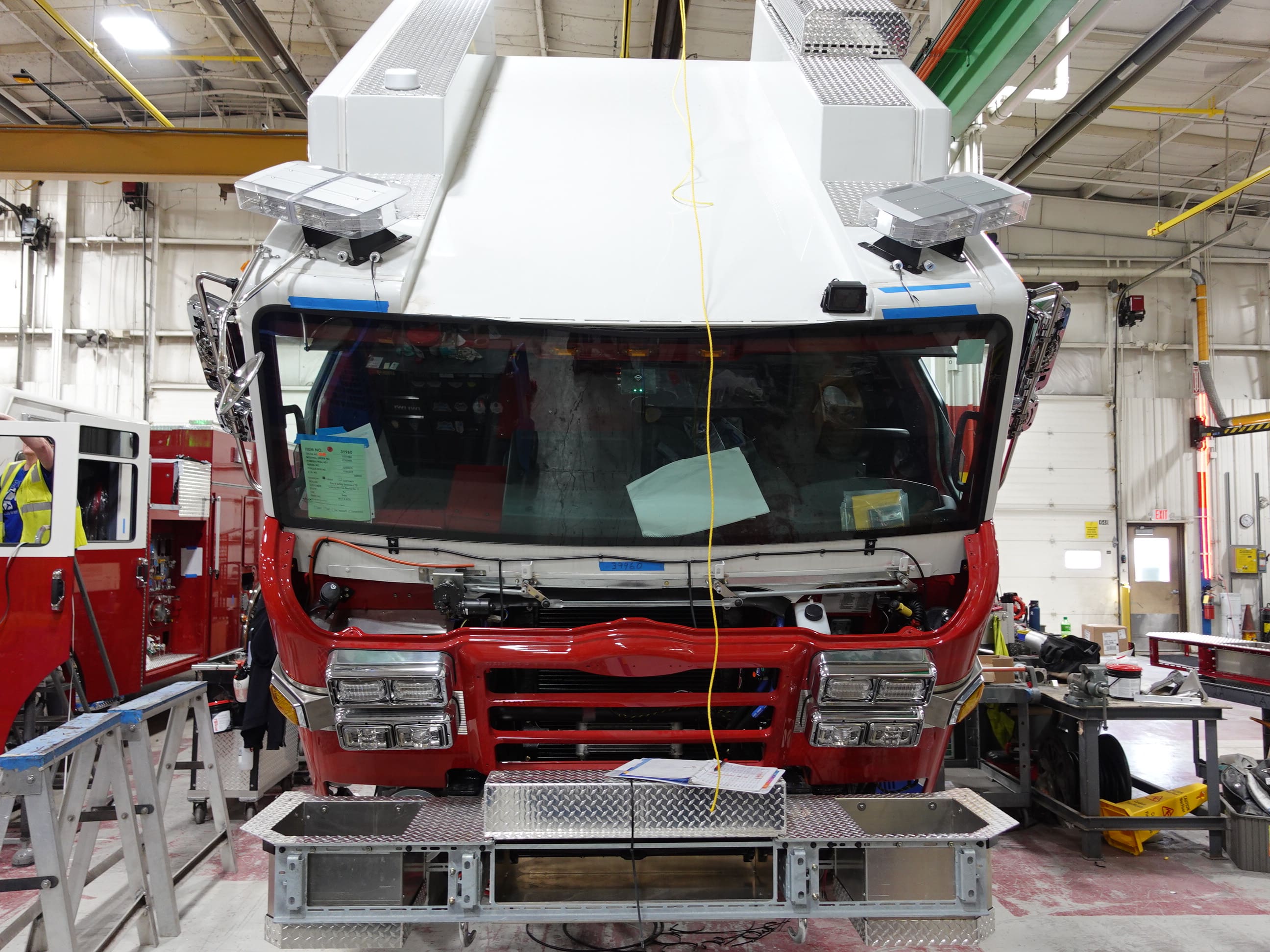

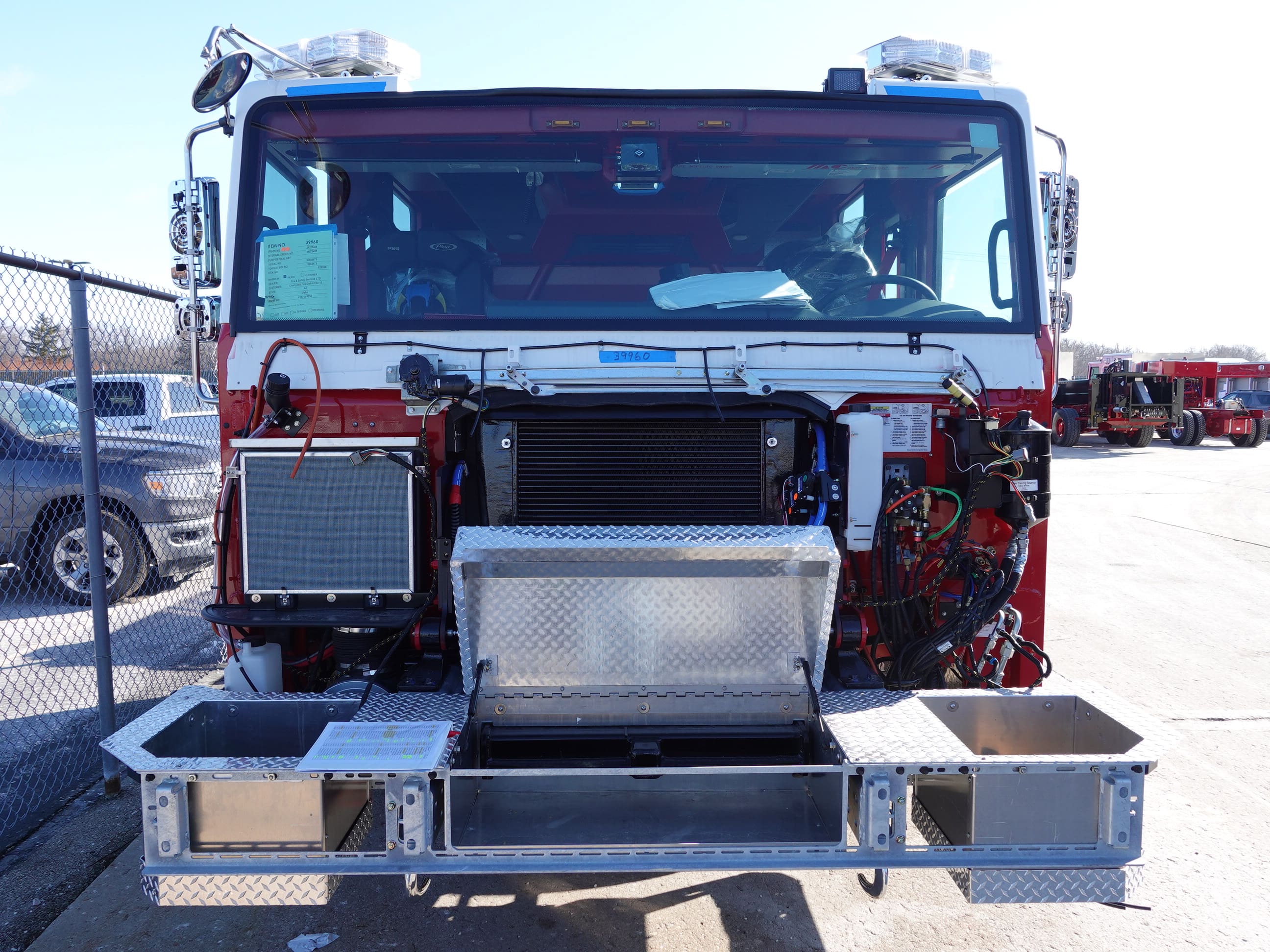

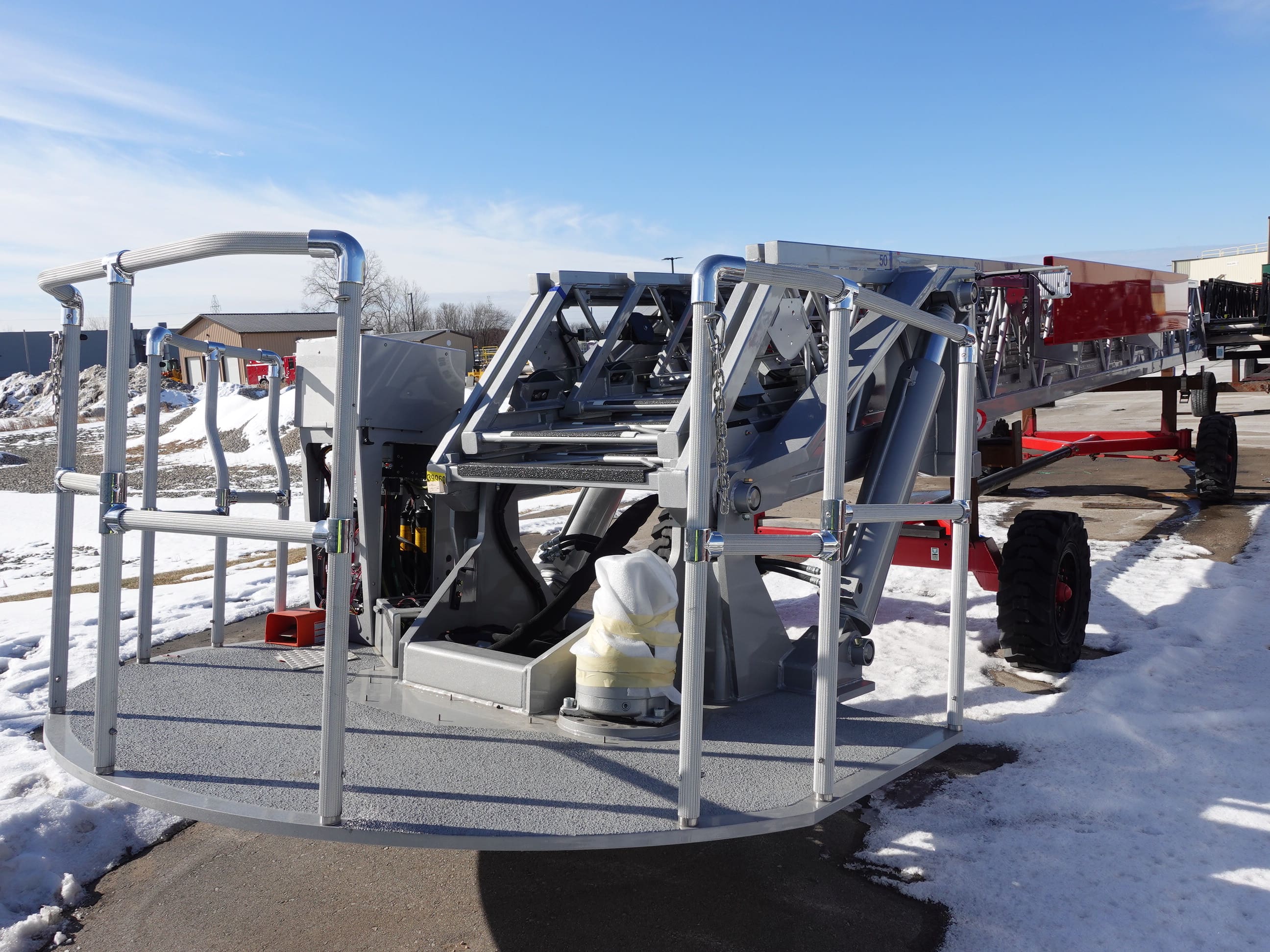

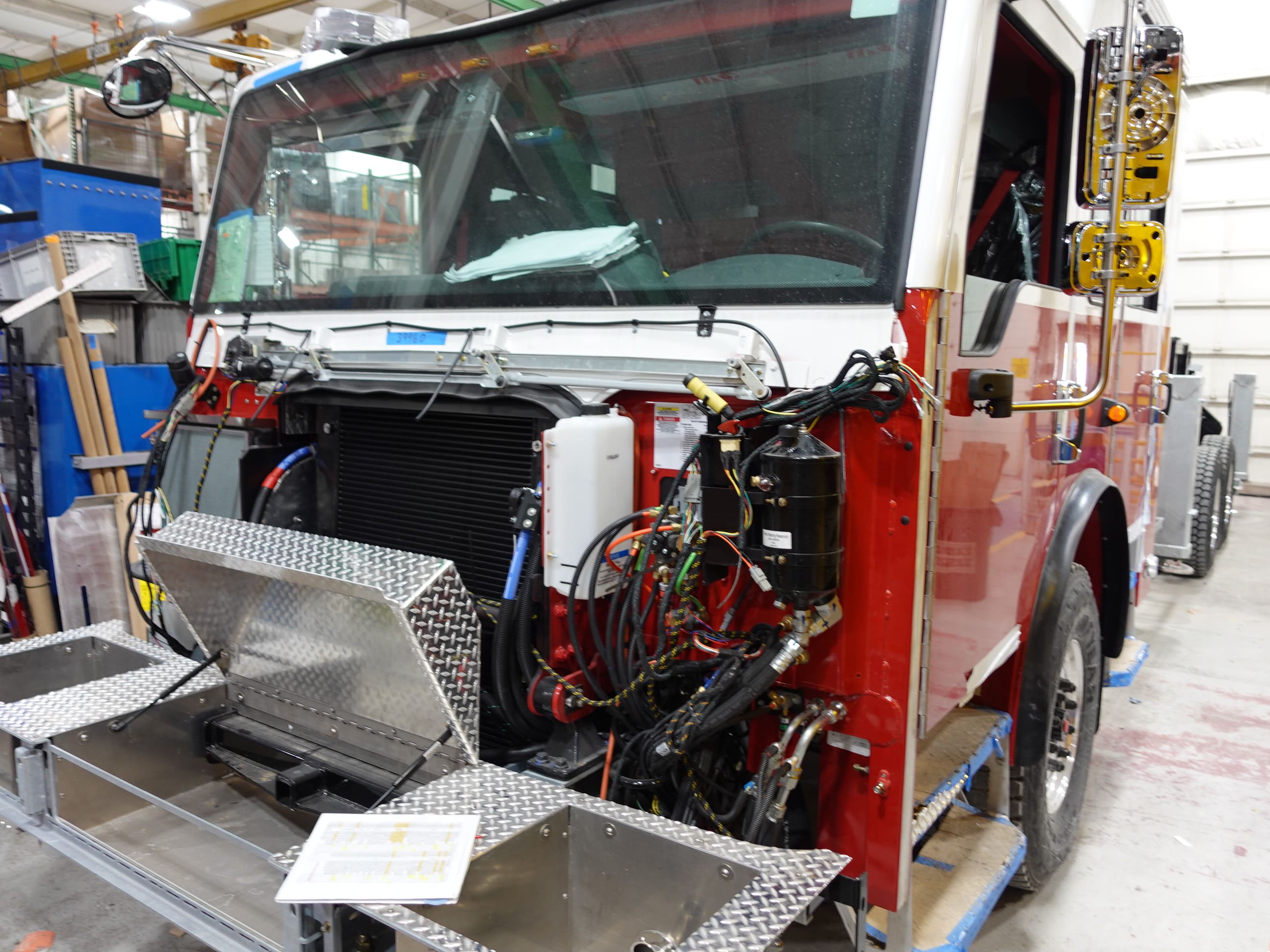

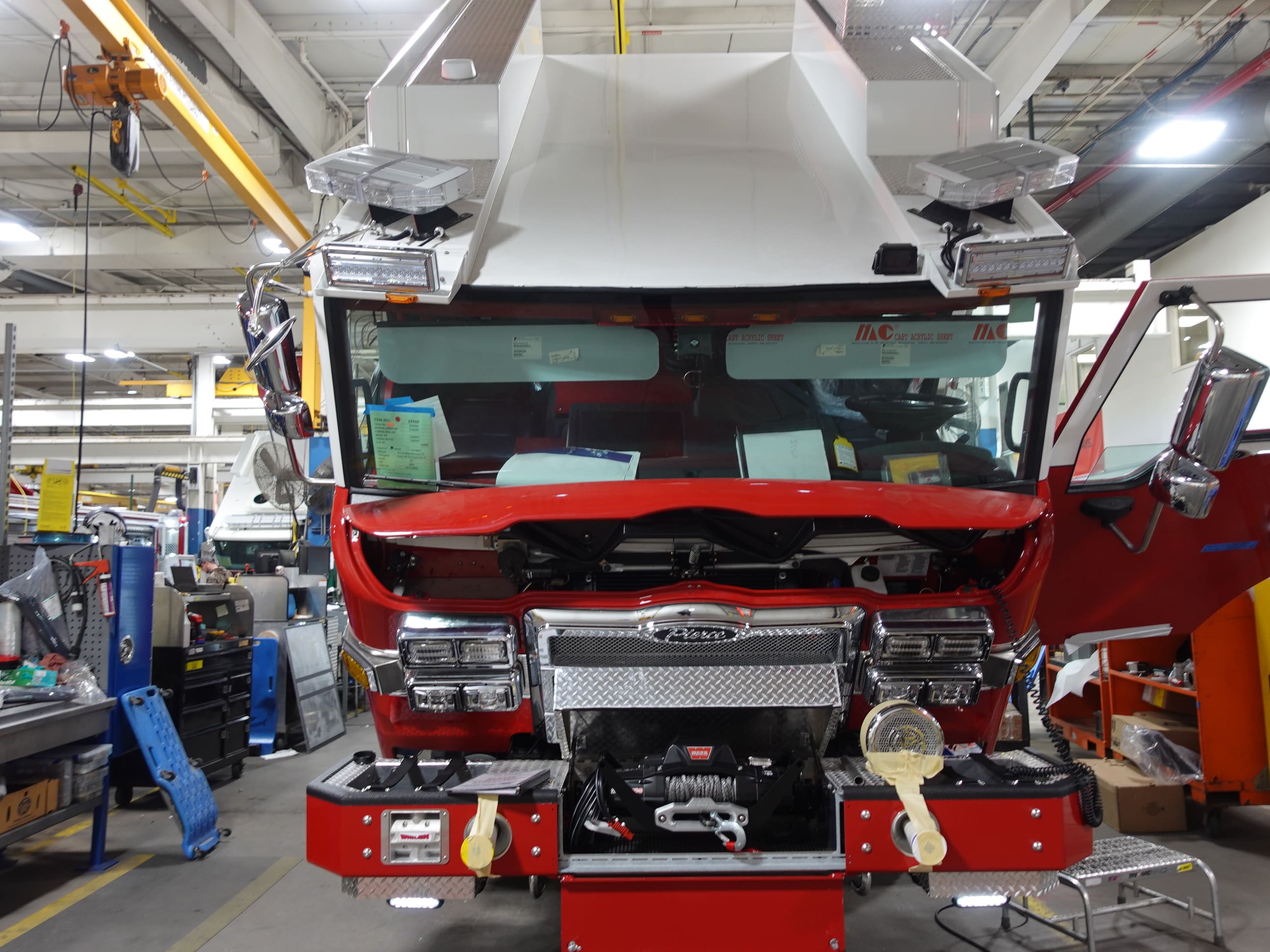

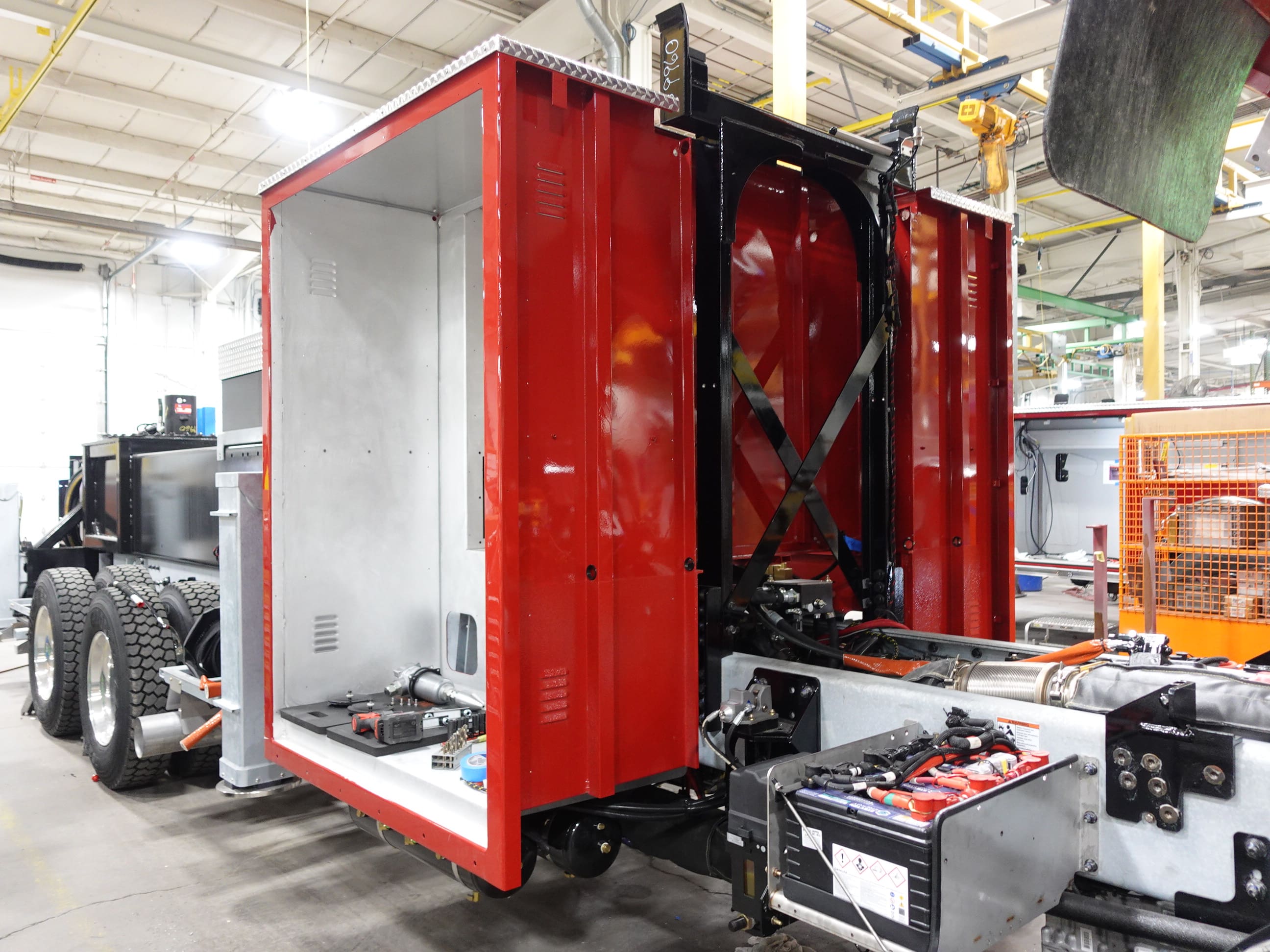

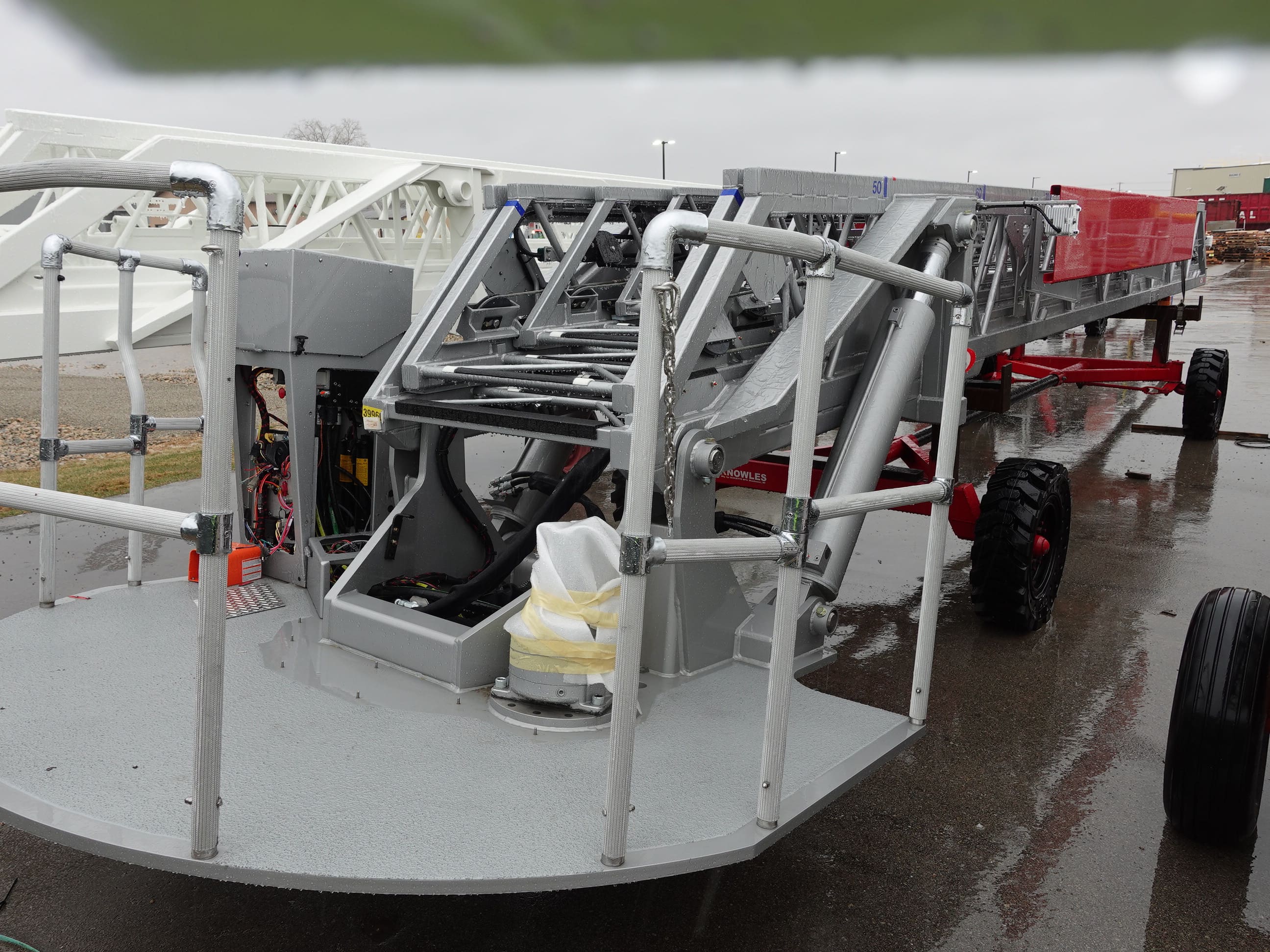

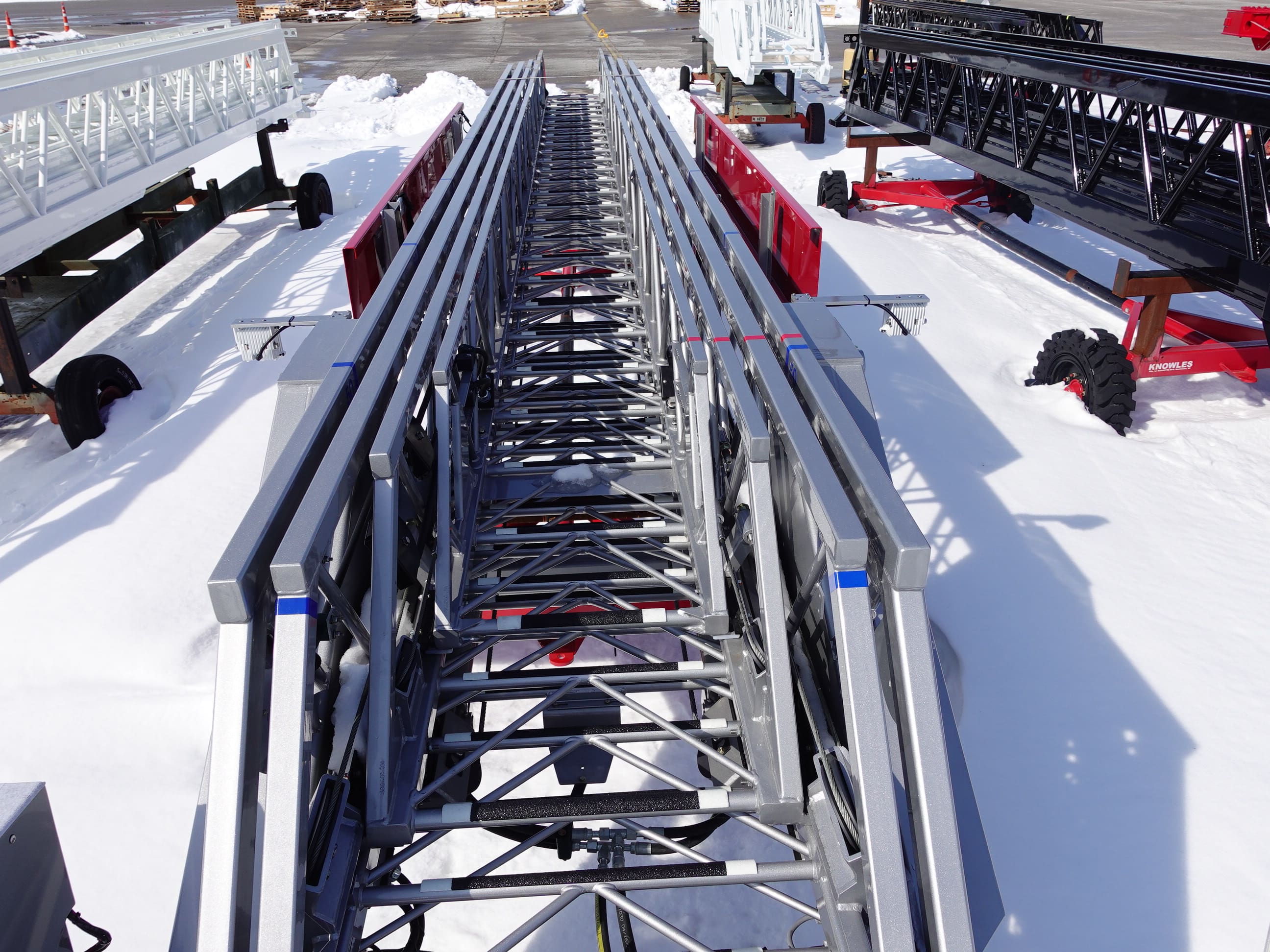

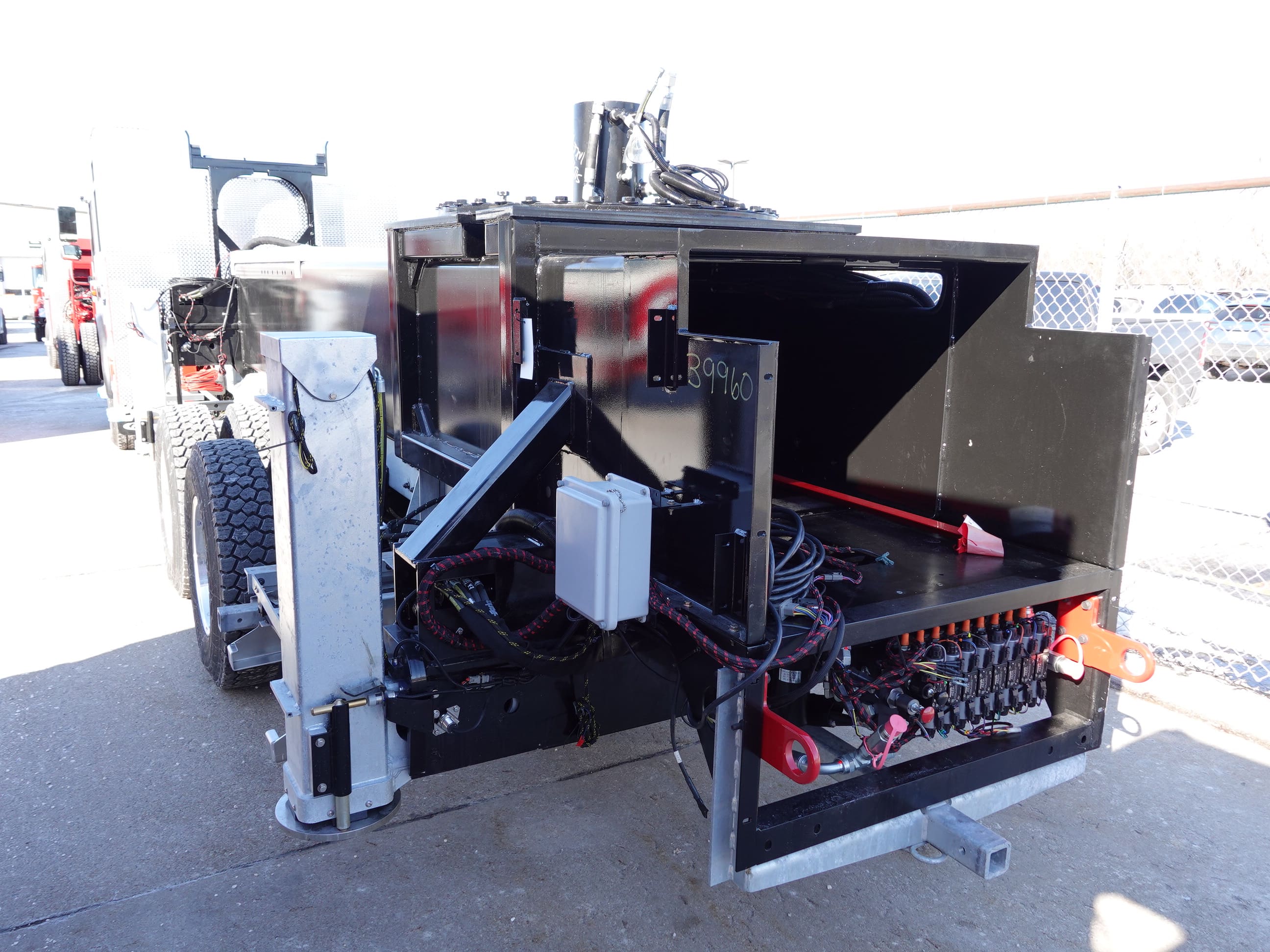

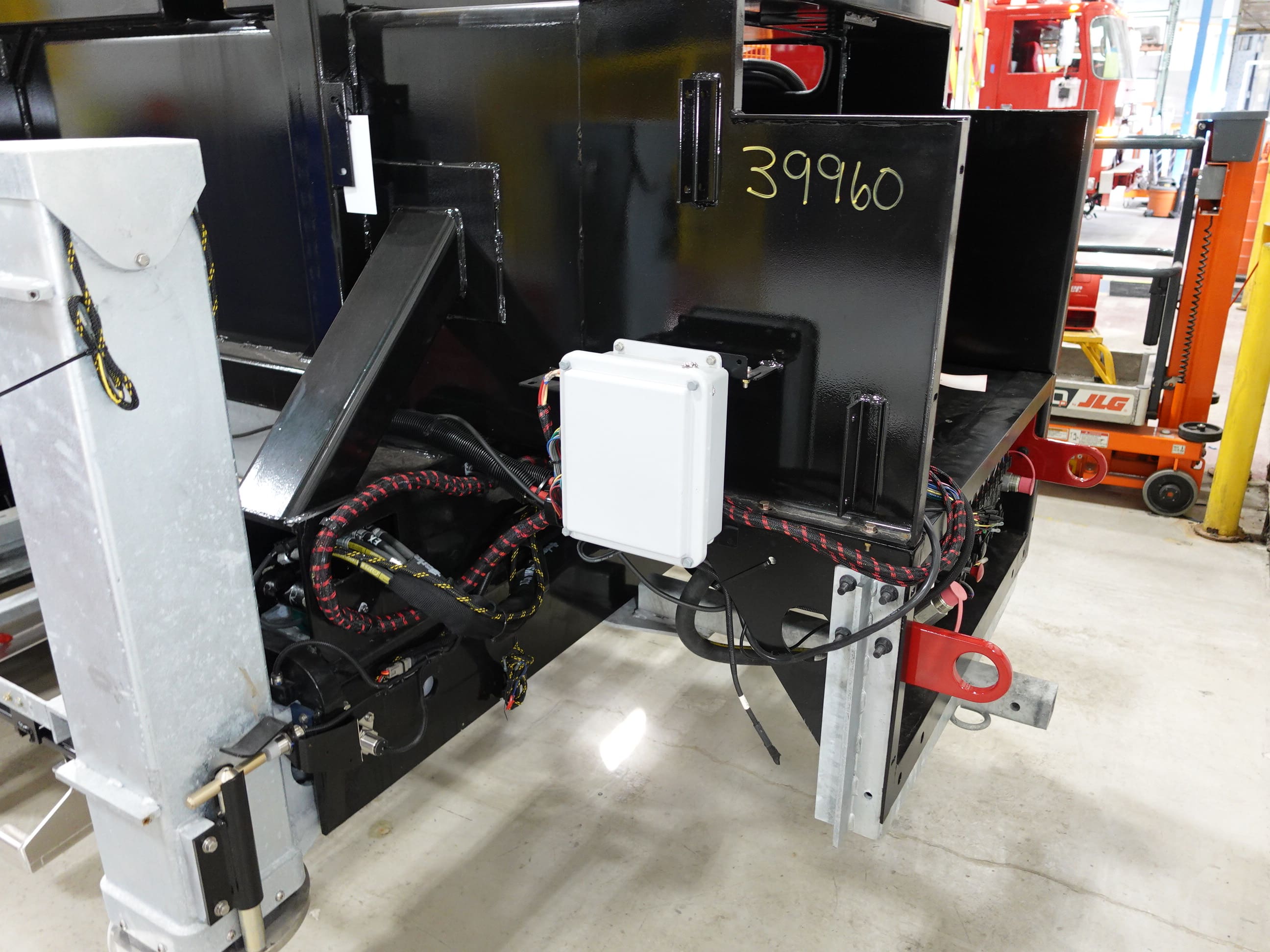

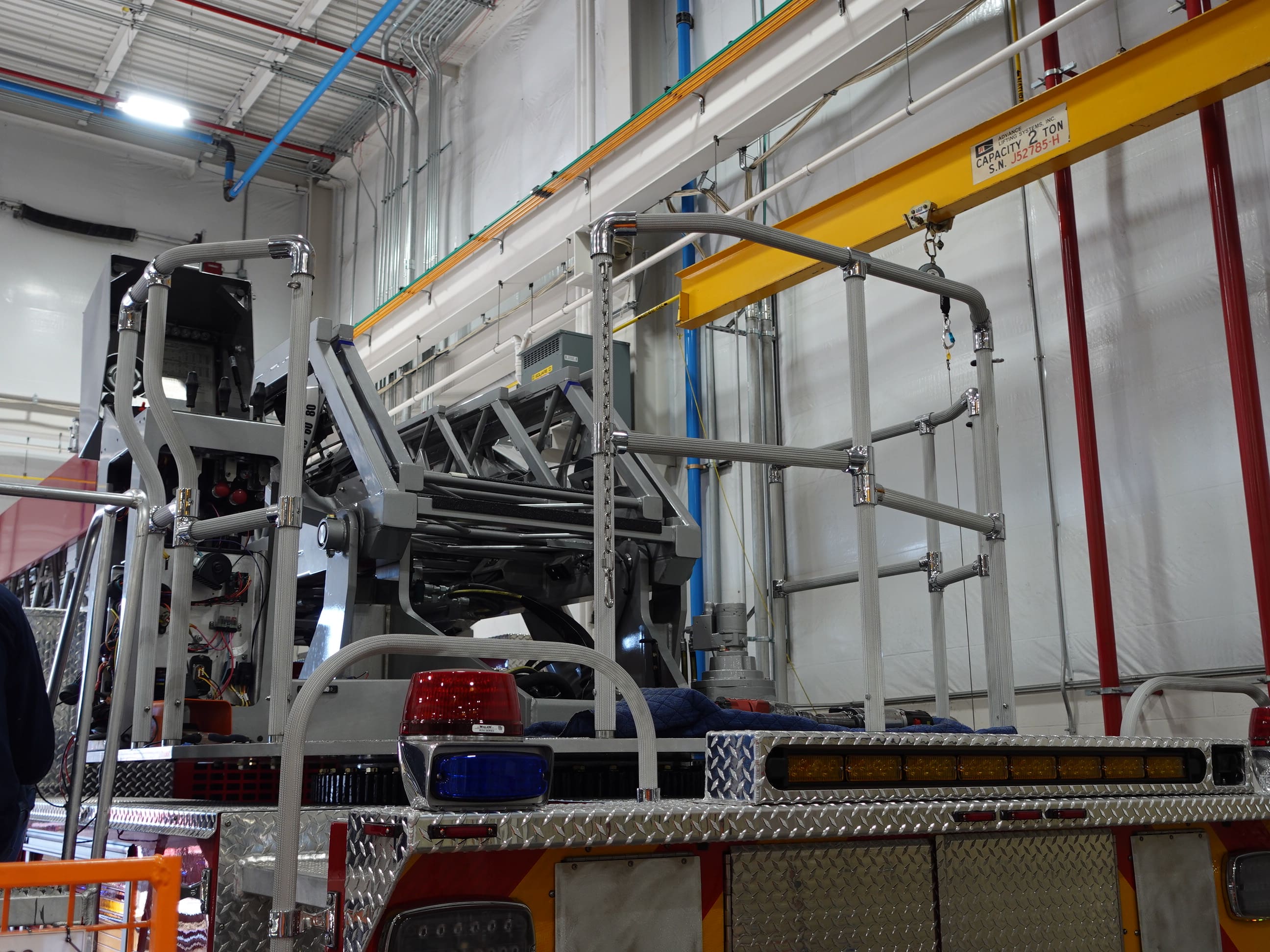

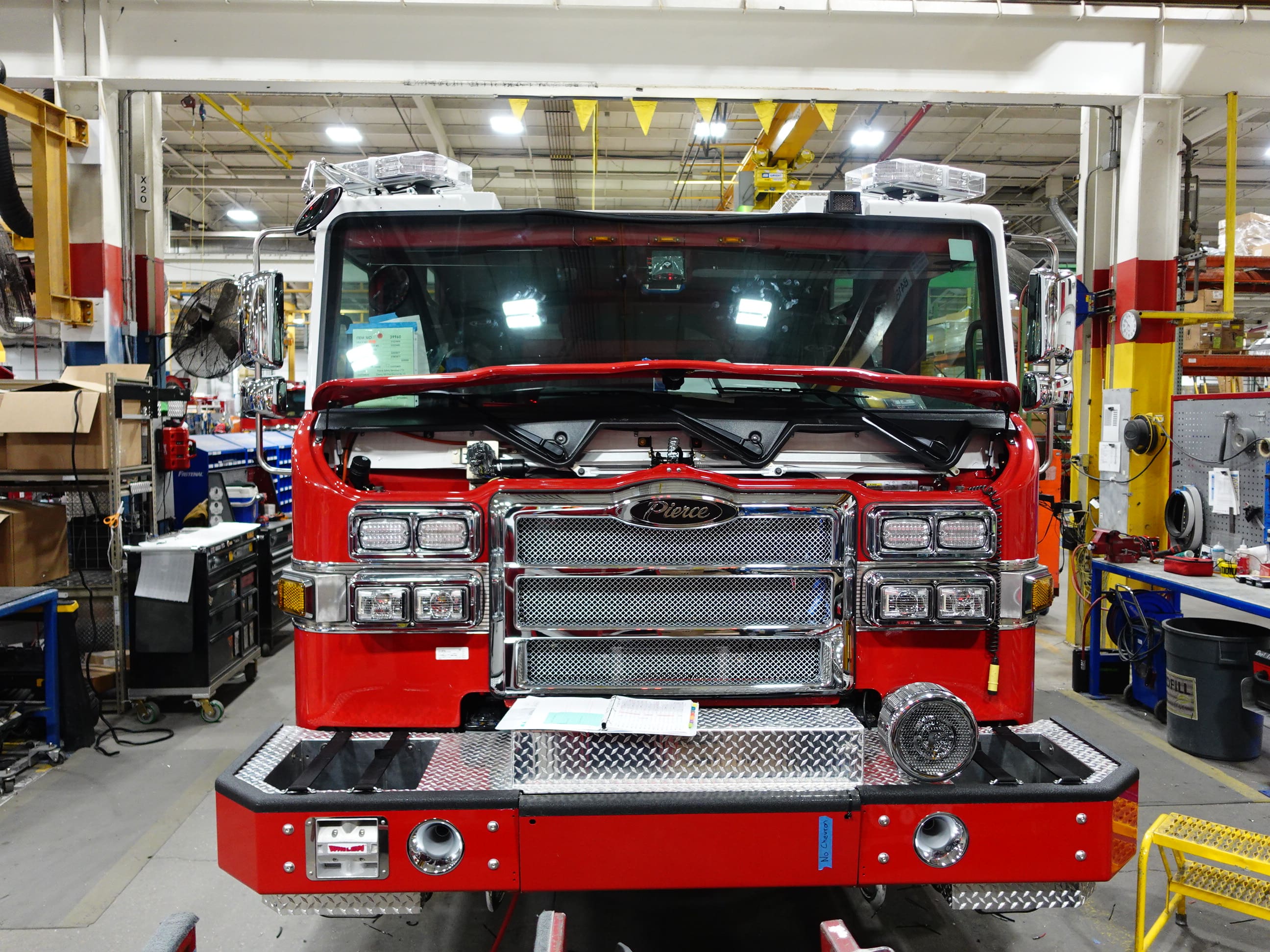

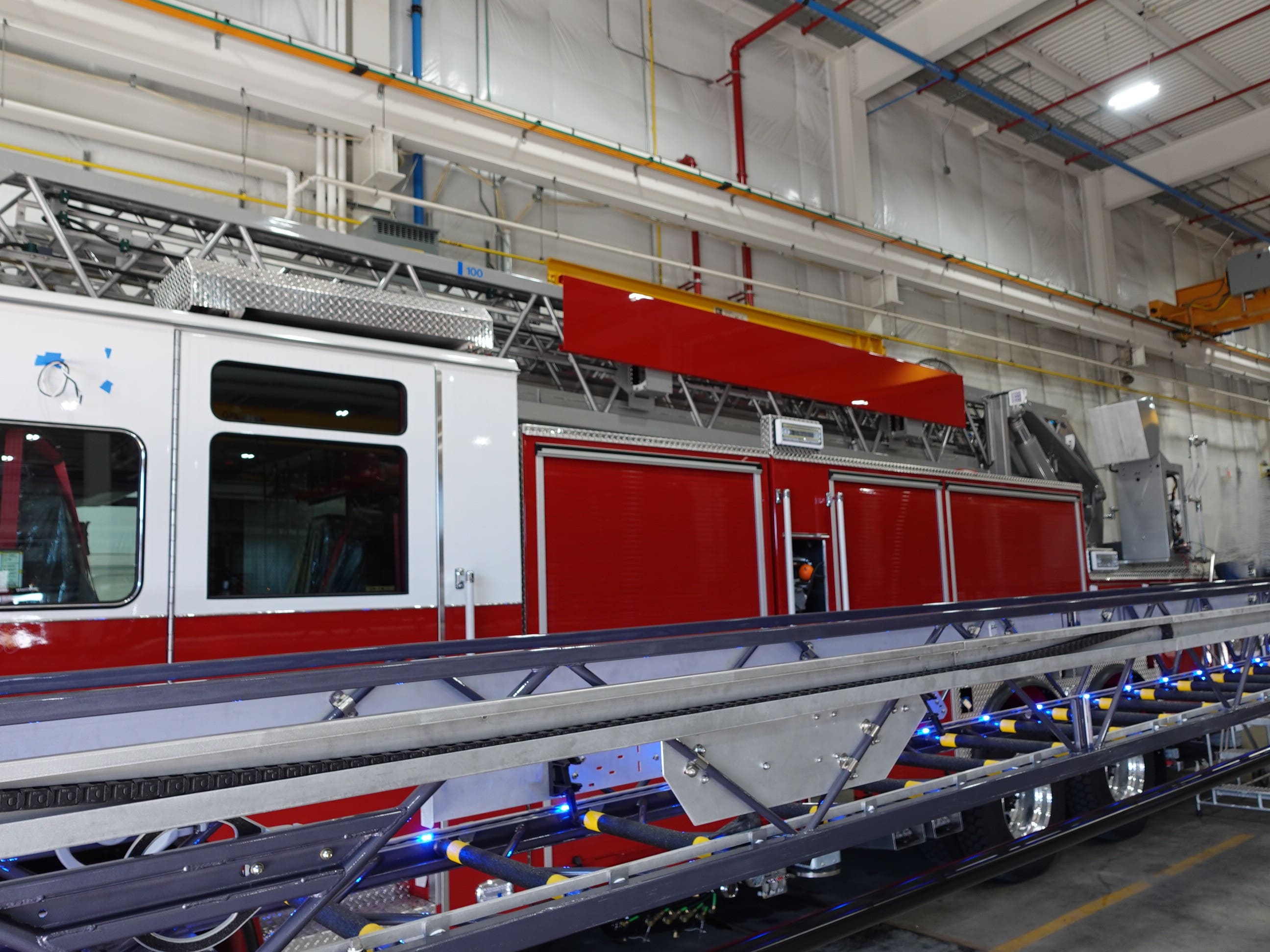

In this report, the apparatus continued final assembly while the aerial device remained staged.
04-10-26

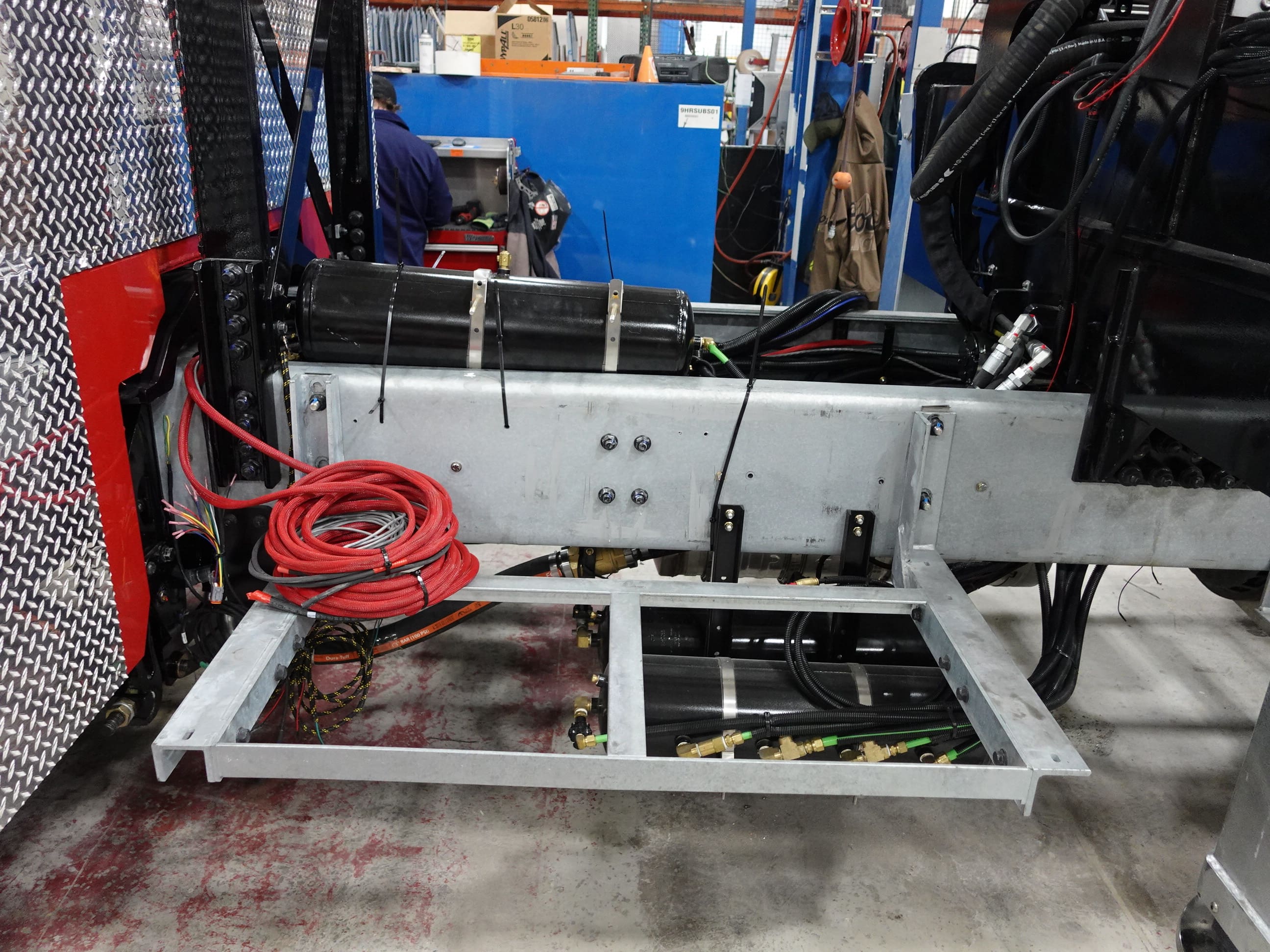

In this report, the apparatus continued some assembly while the aerial device remained staged.

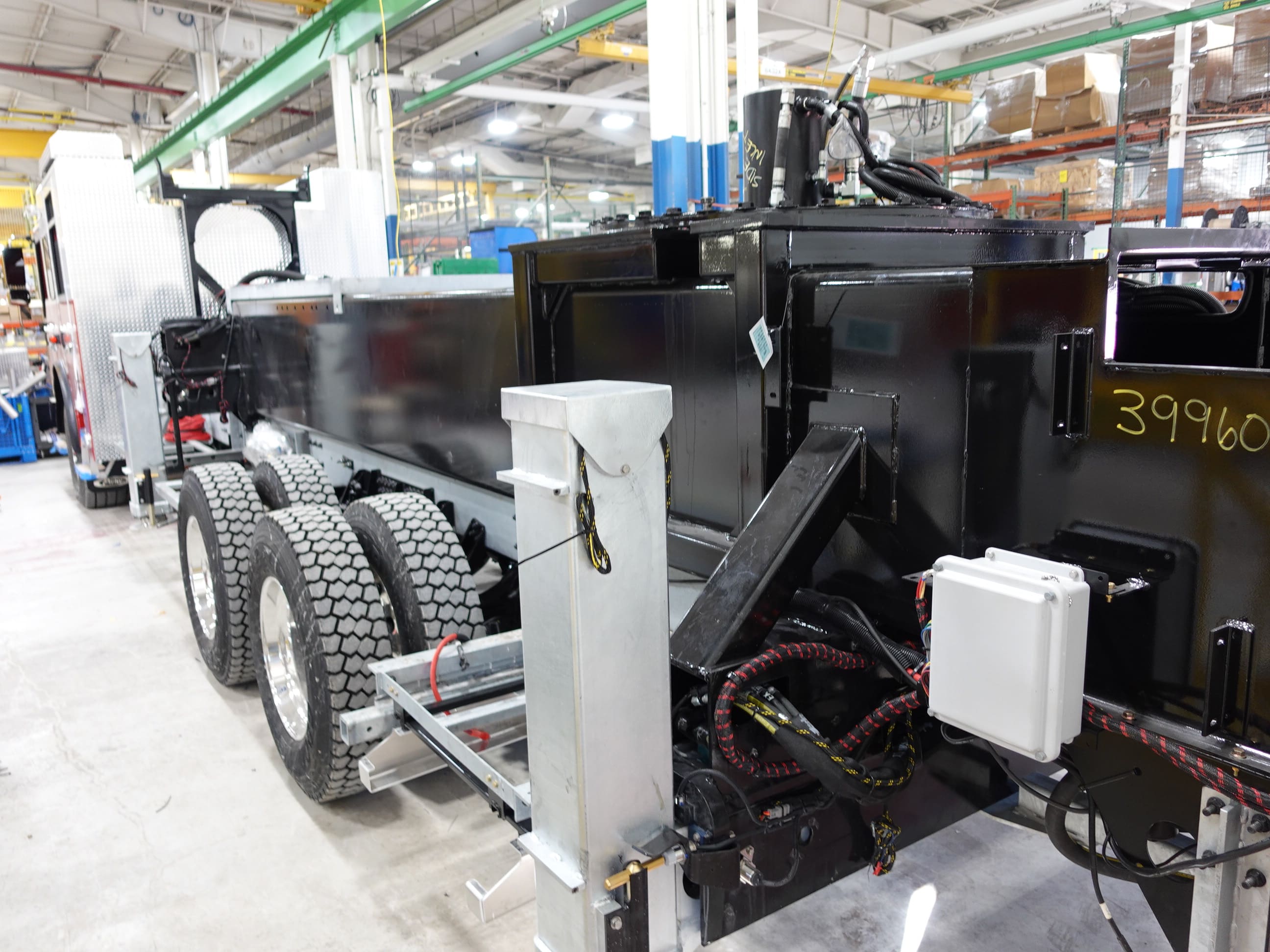

04-03-26

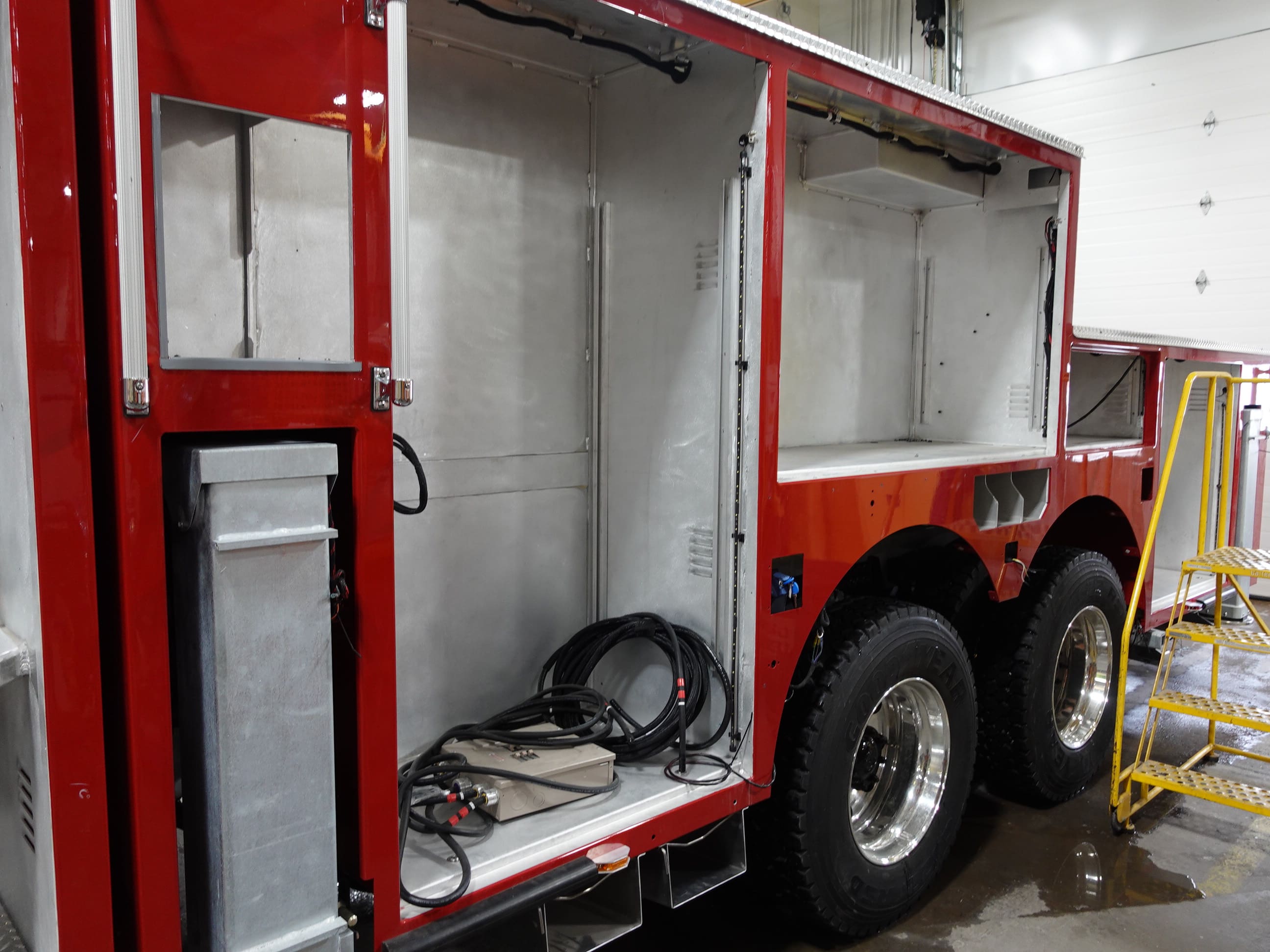

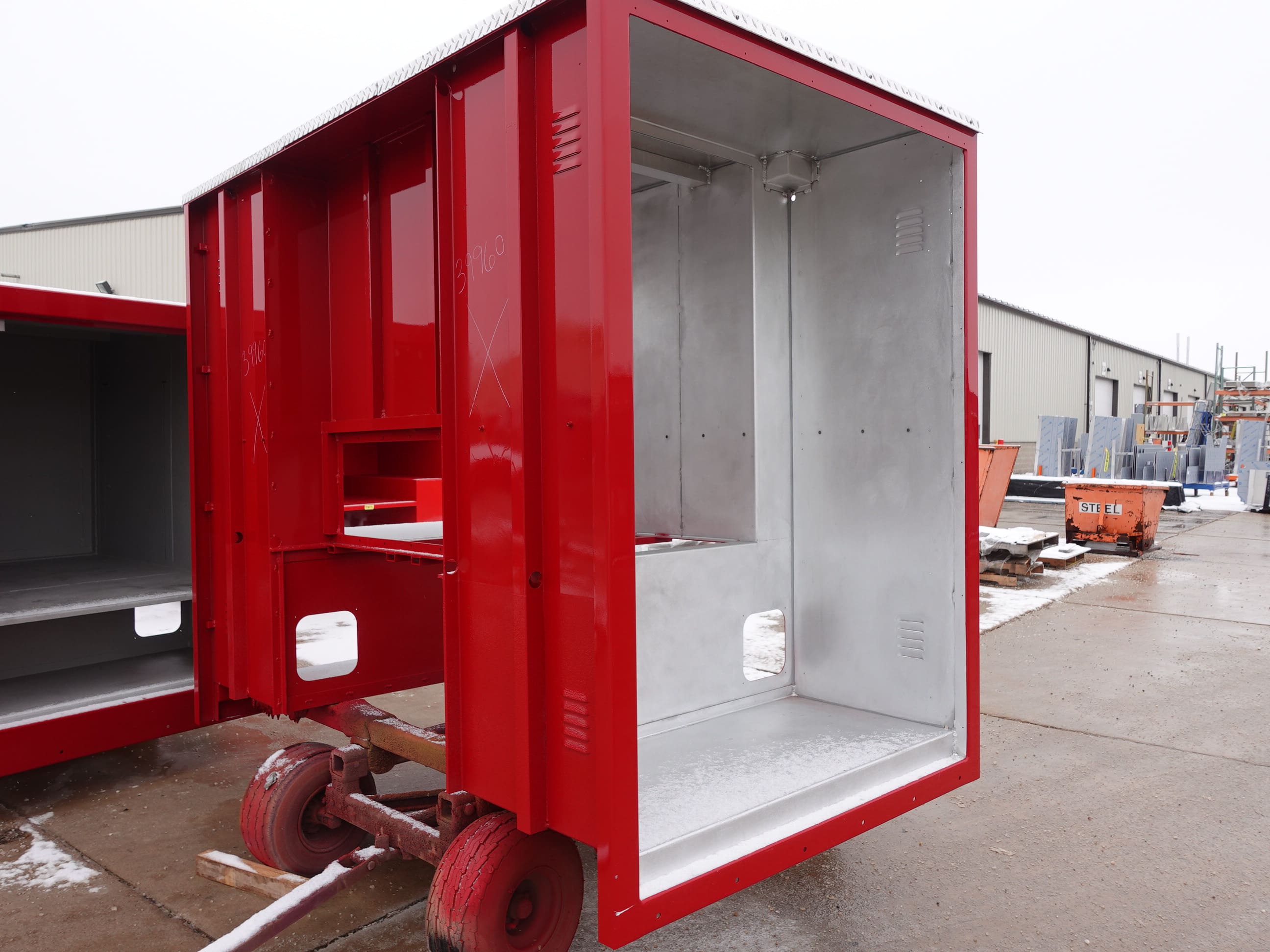

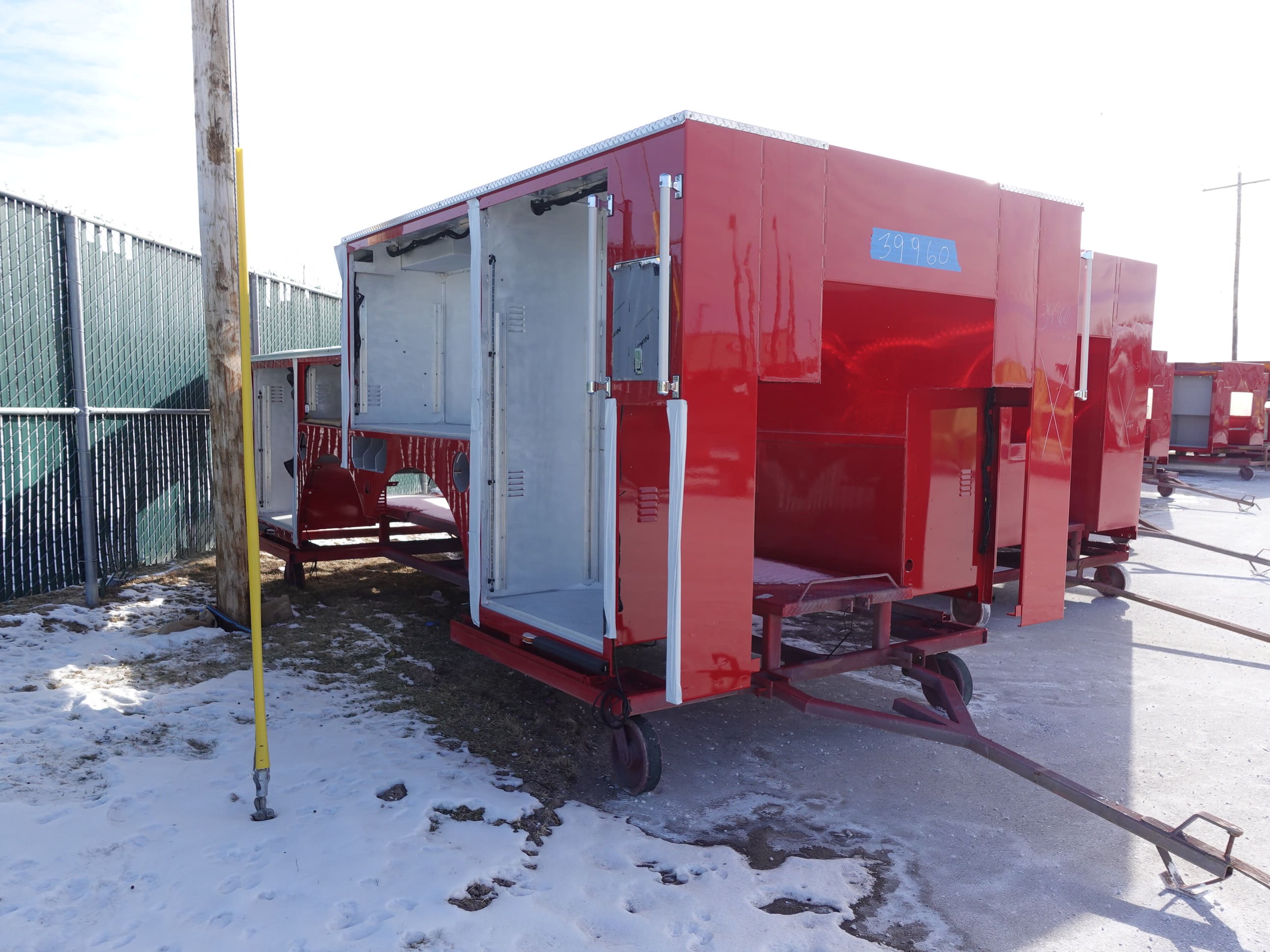

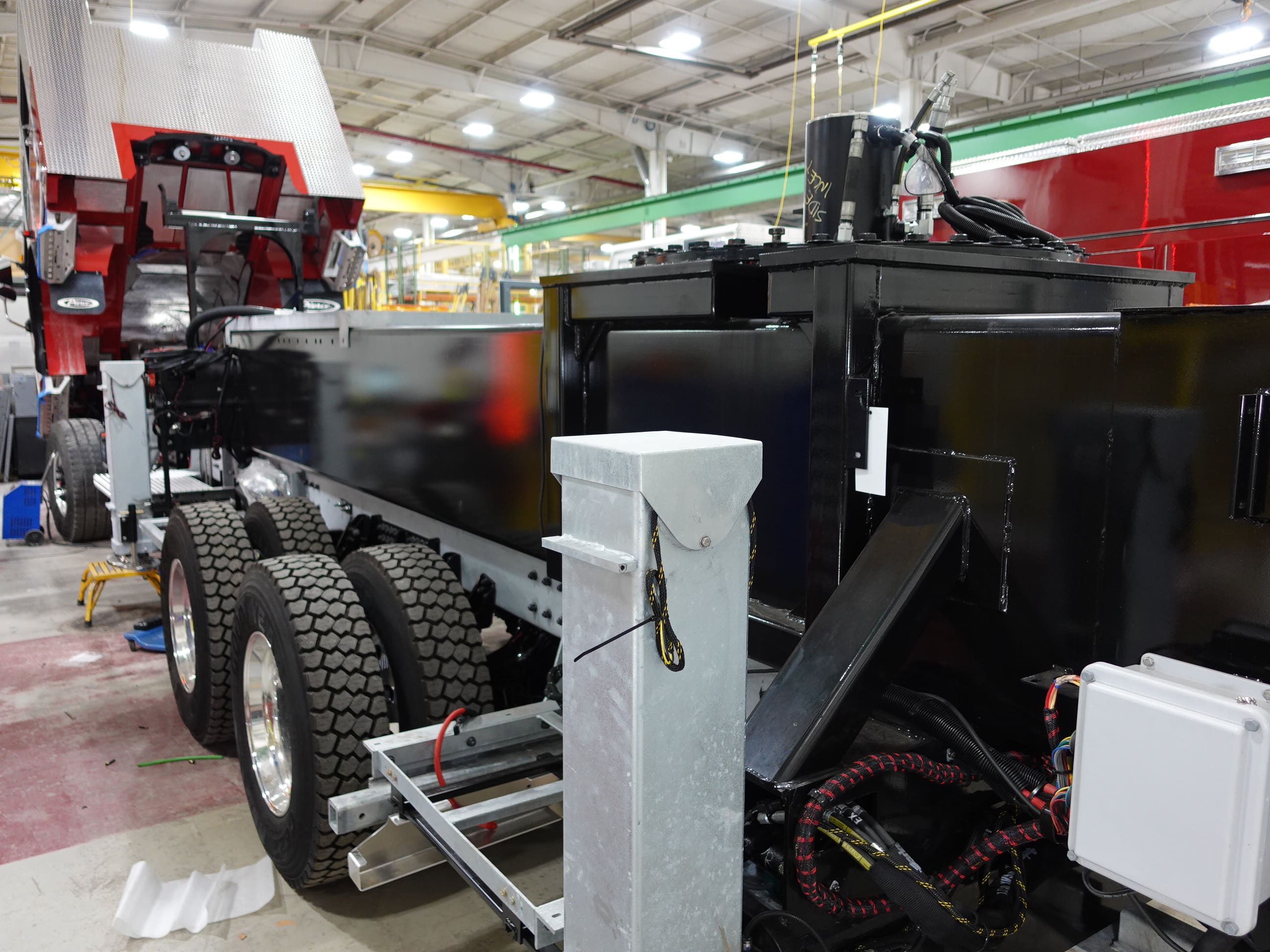

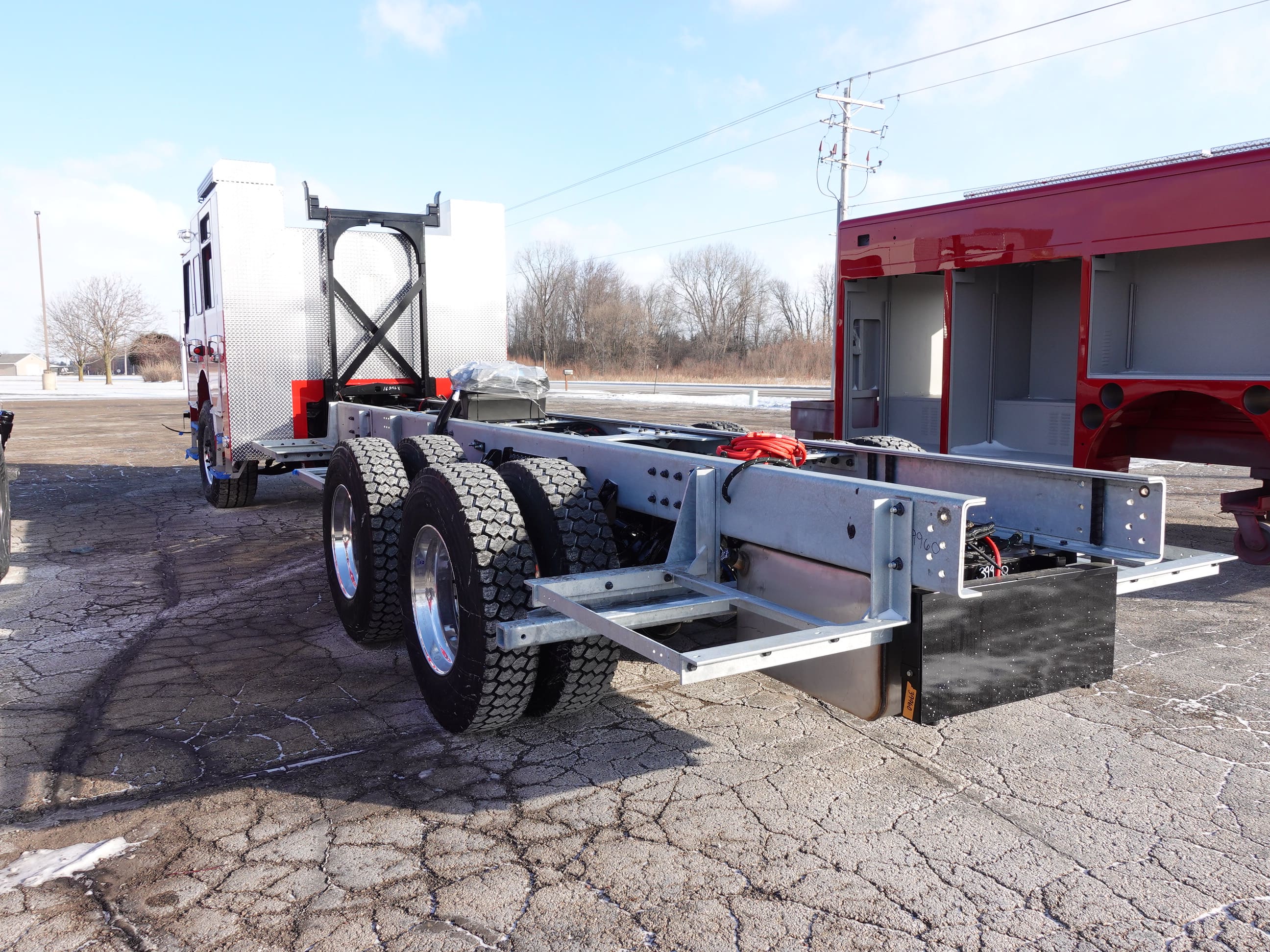

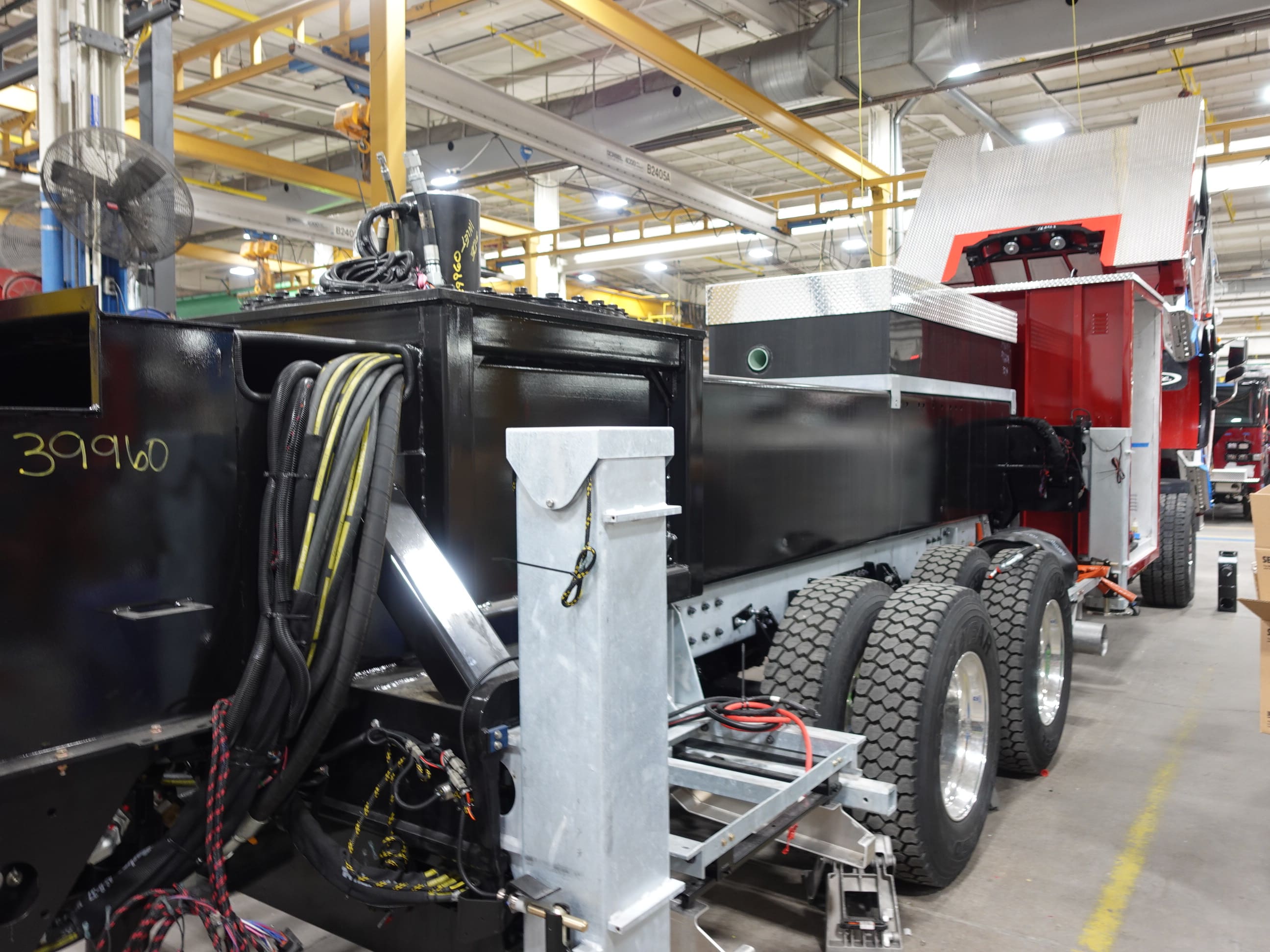

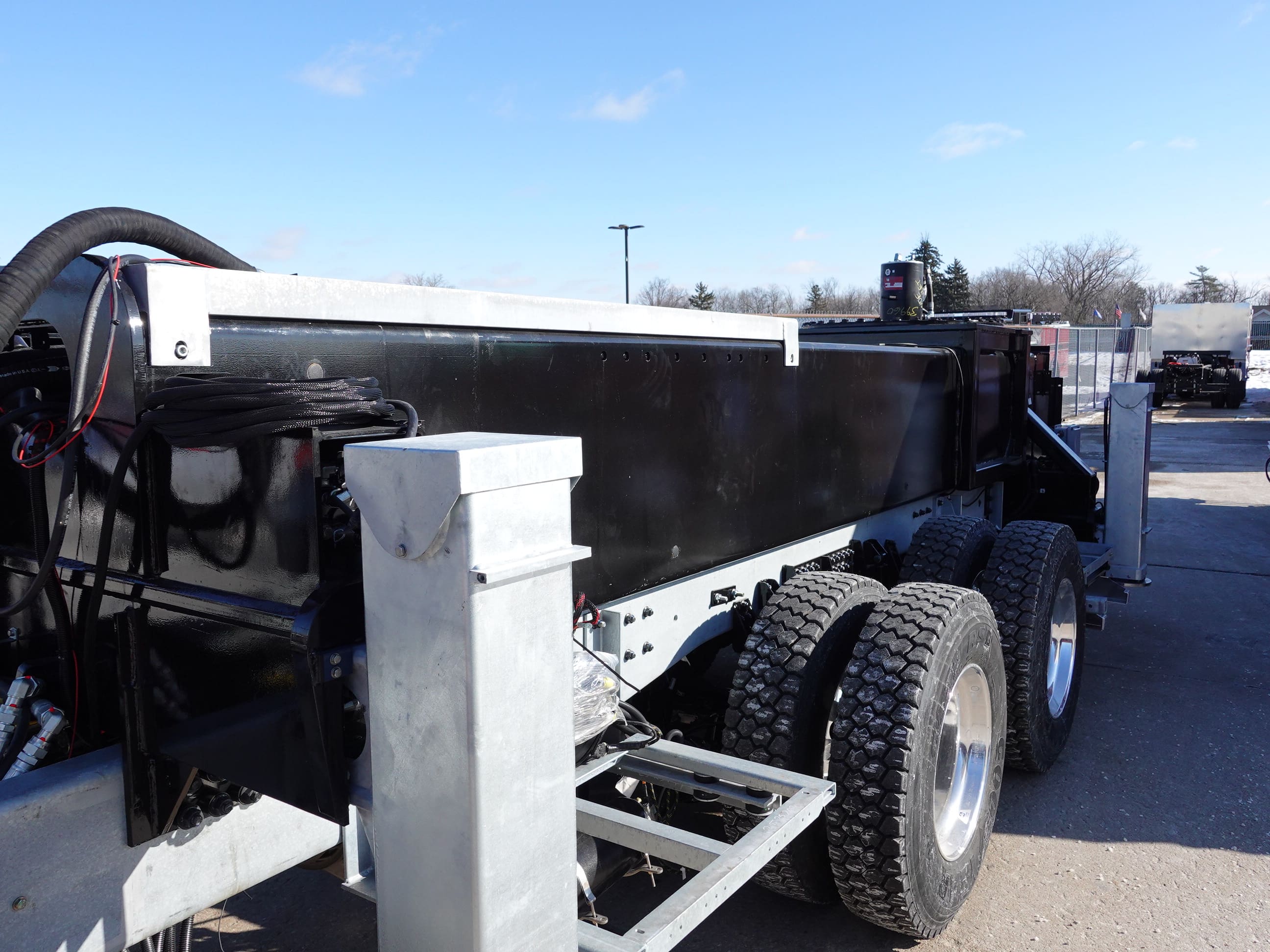

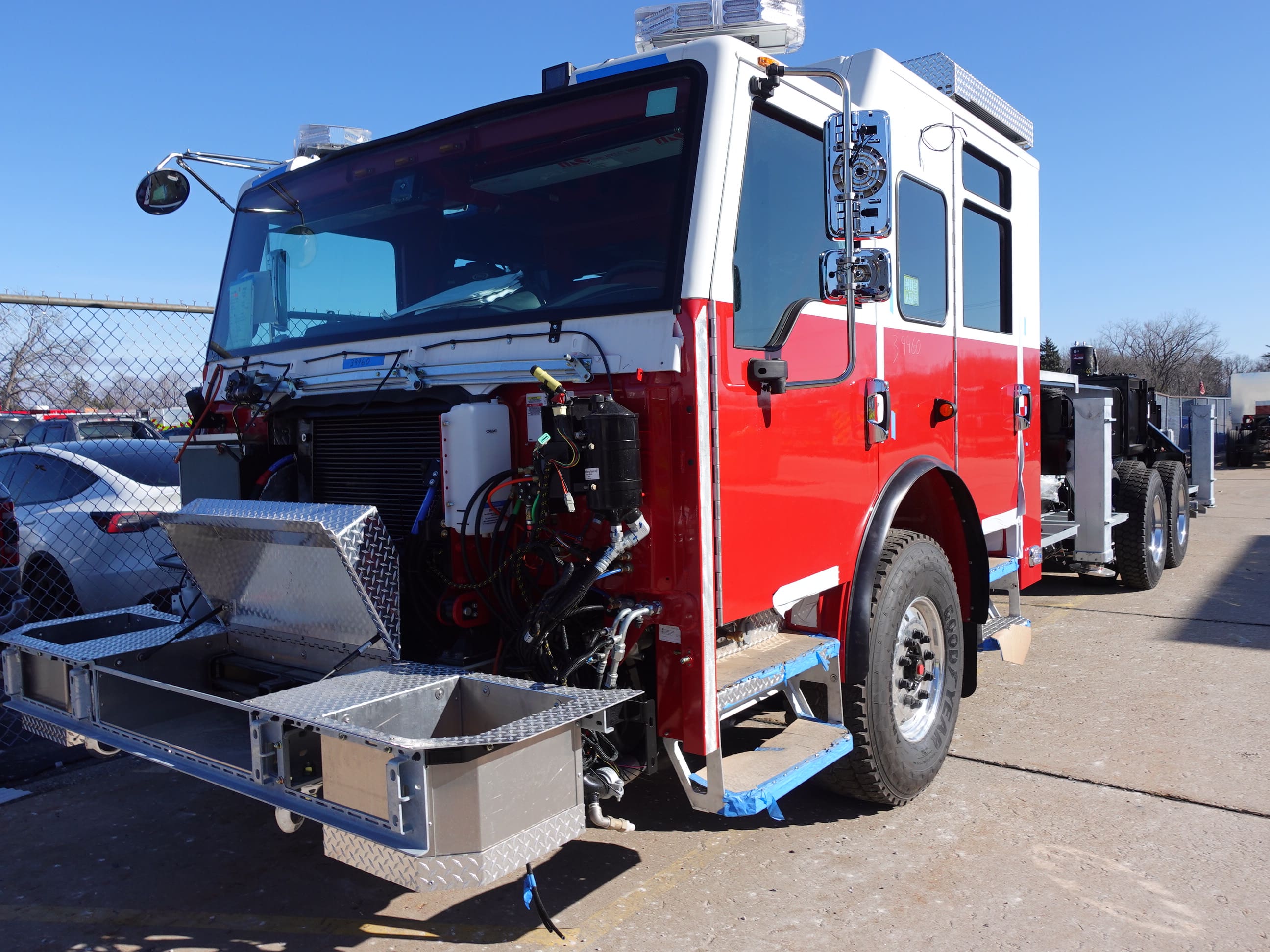

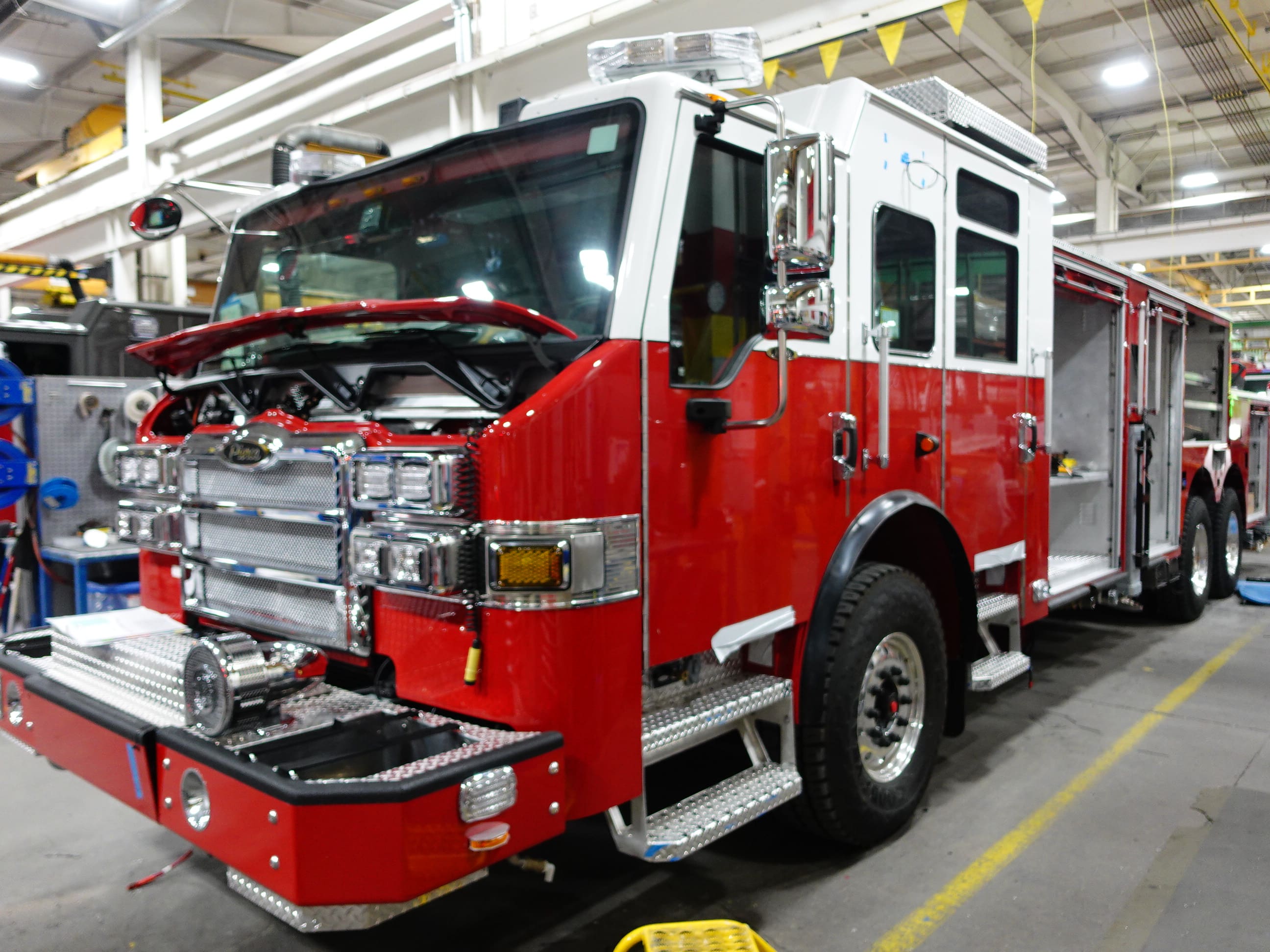

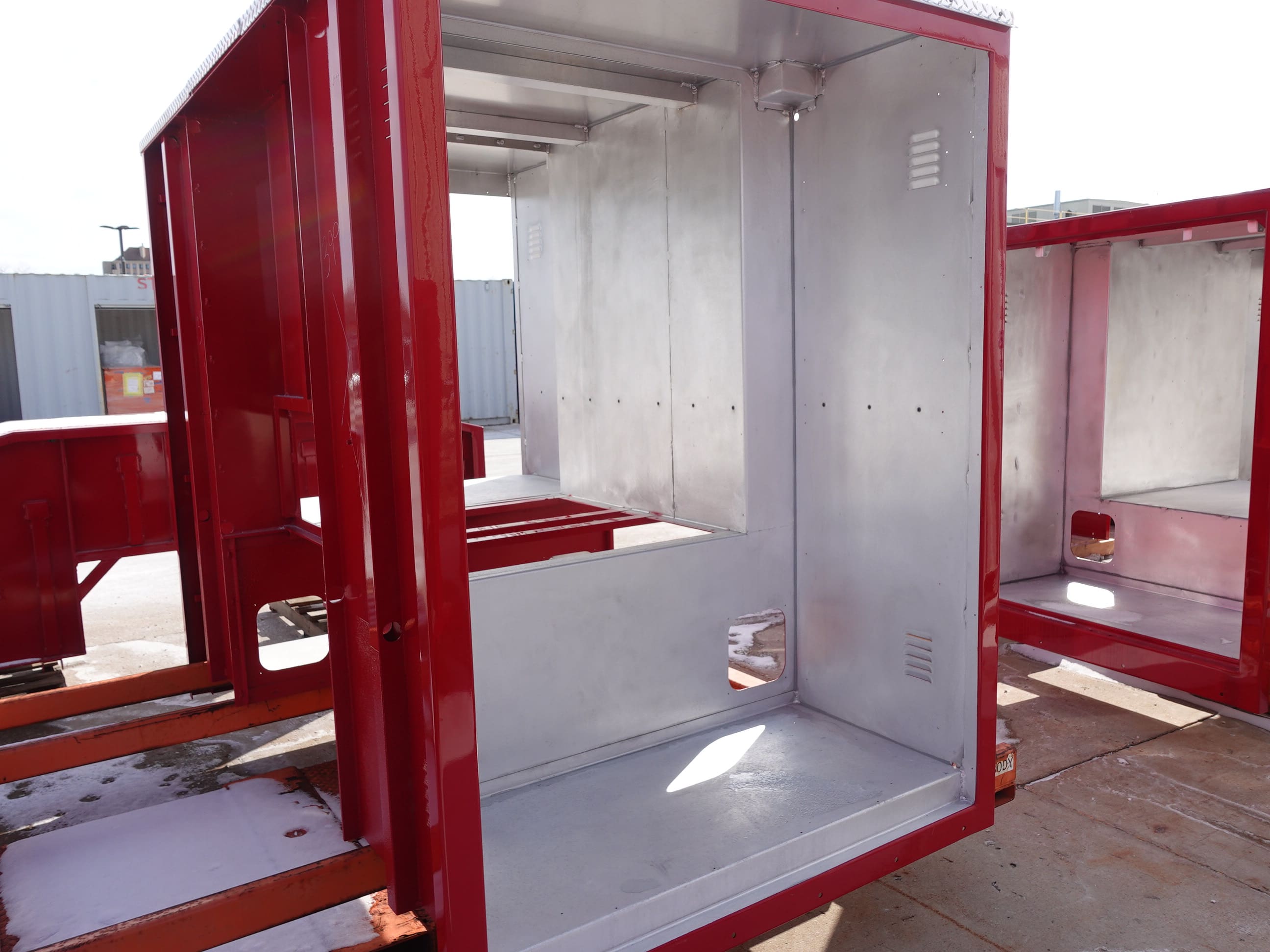

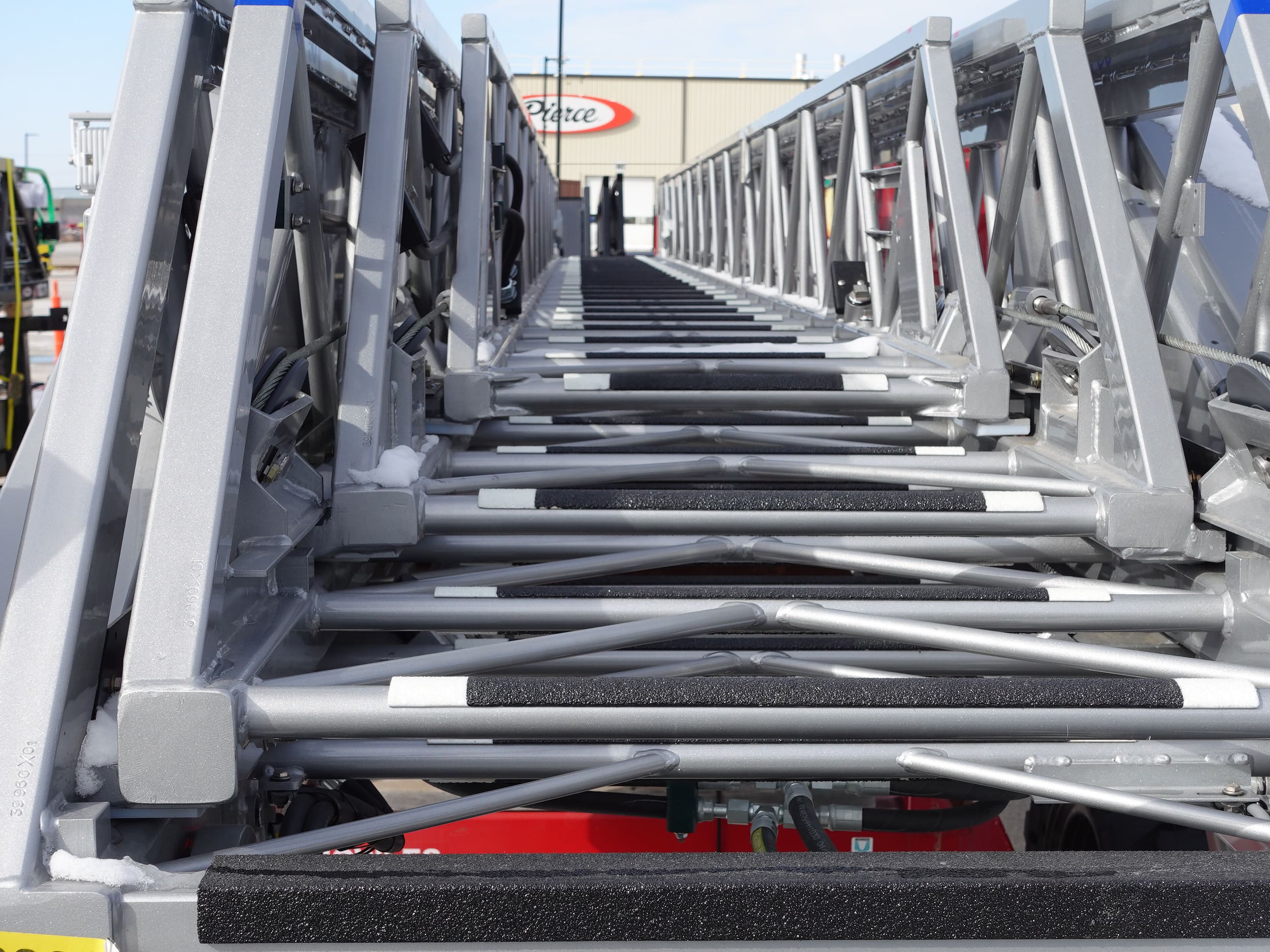

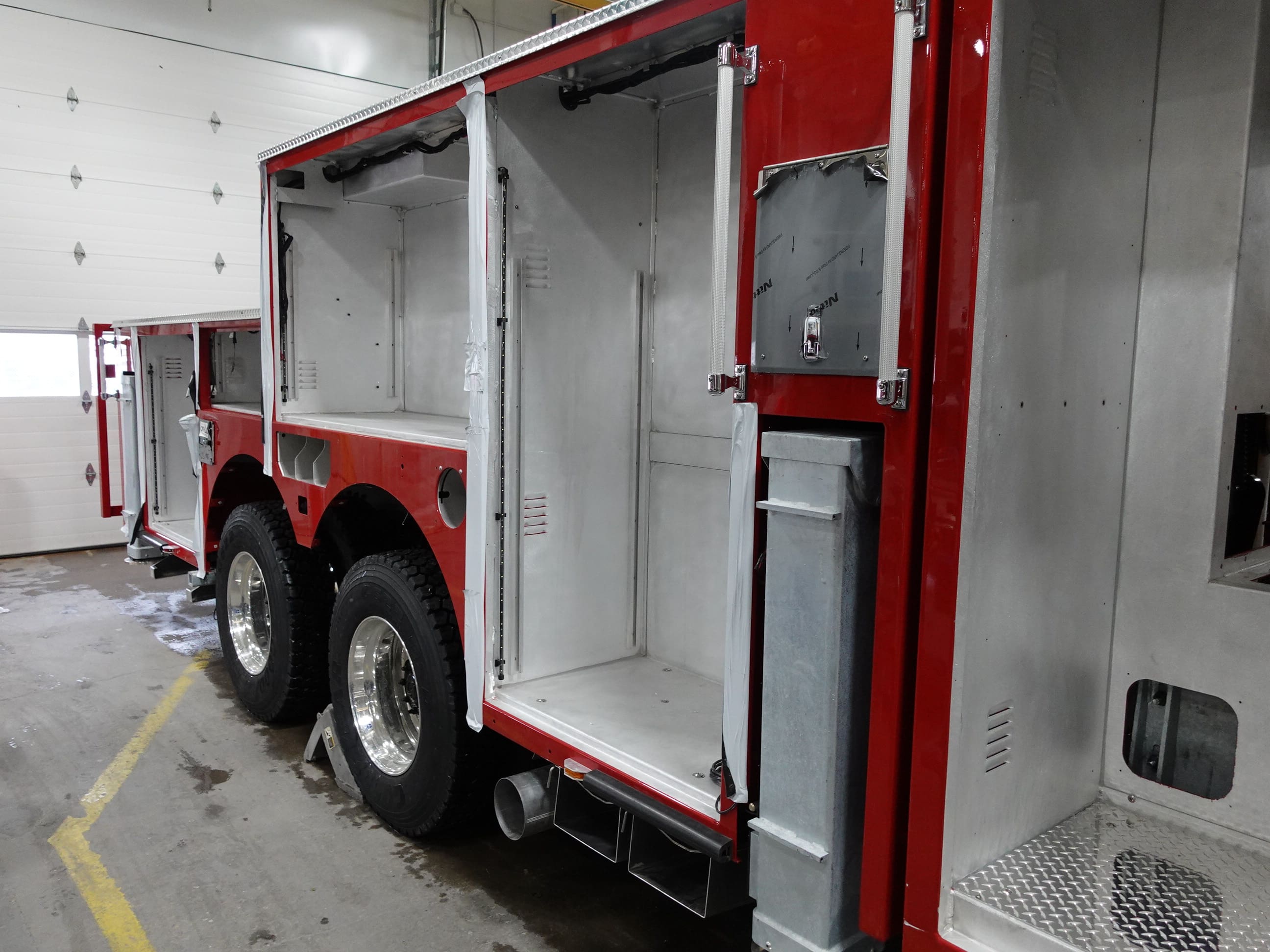

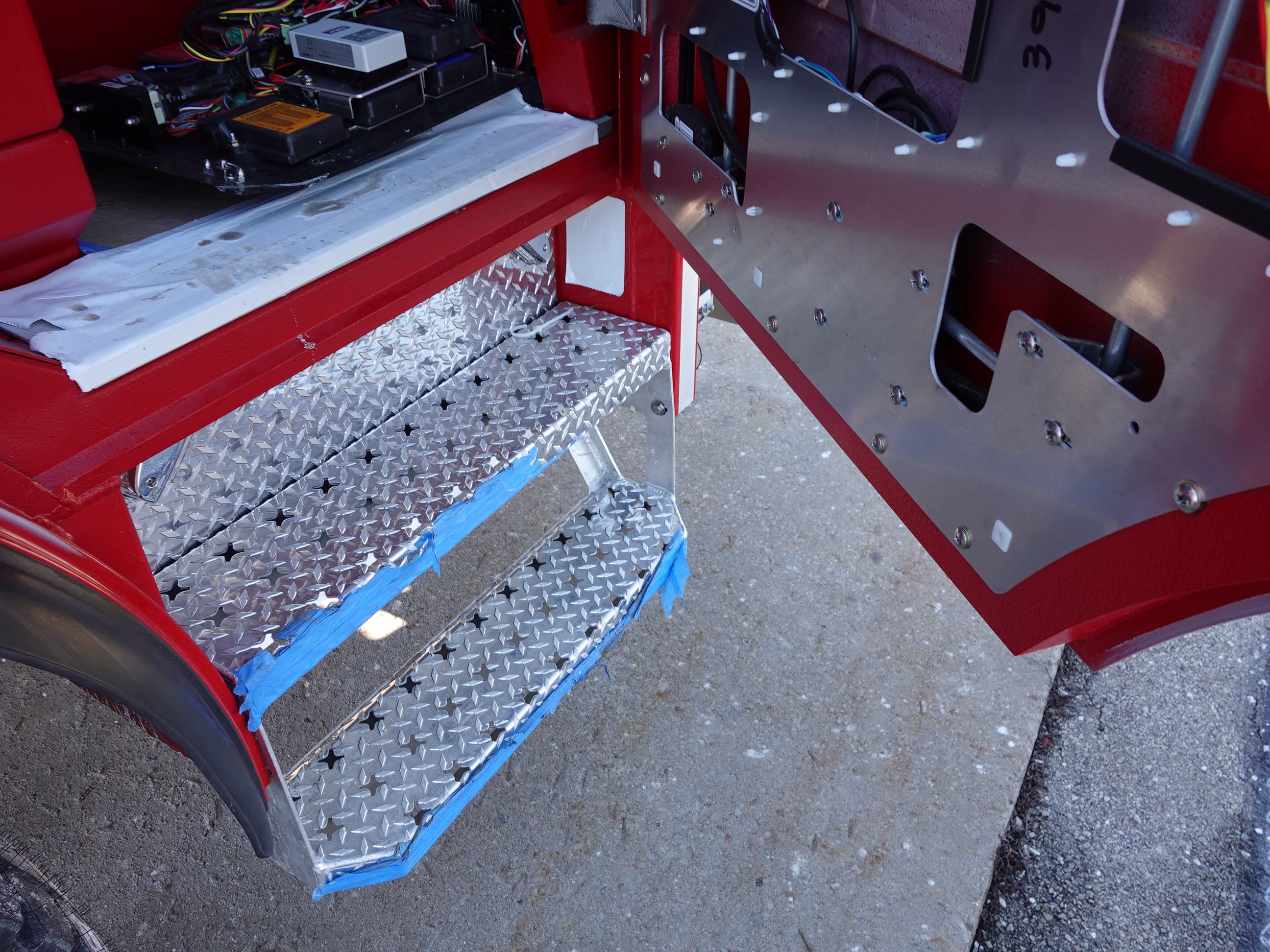

In this report, the apparatus completed final assembly while the aerial device remained staged.
03-20-26

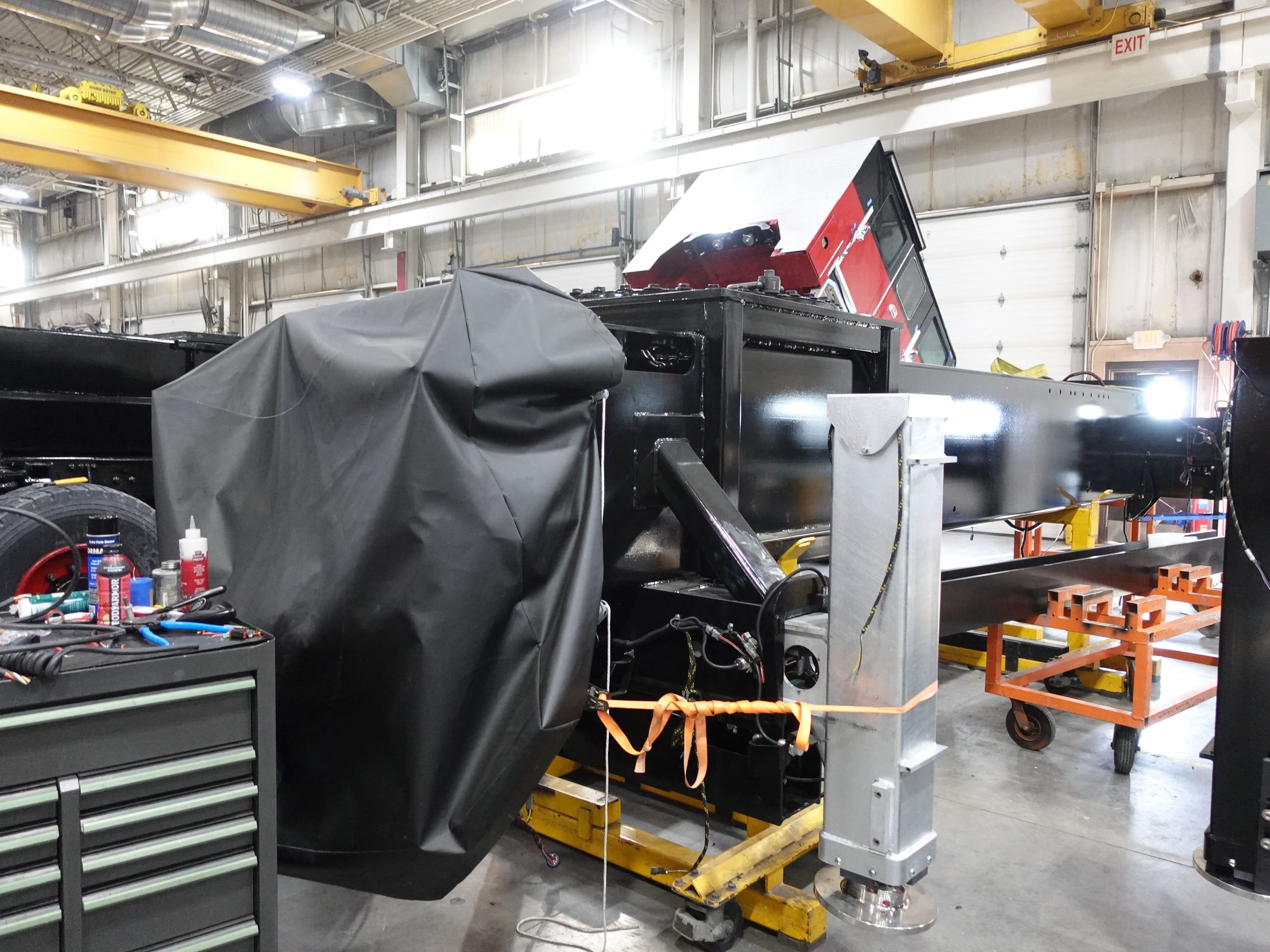

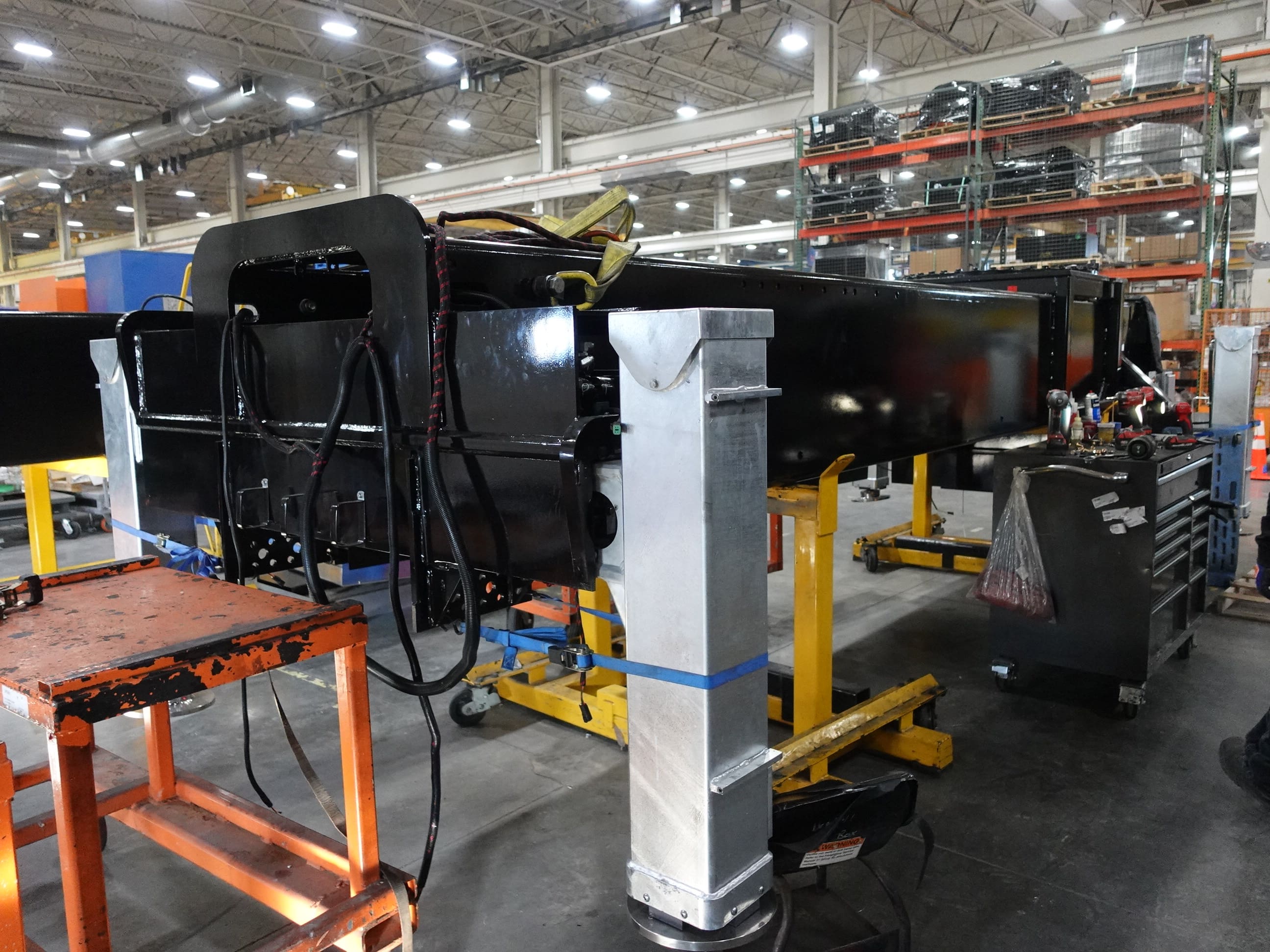

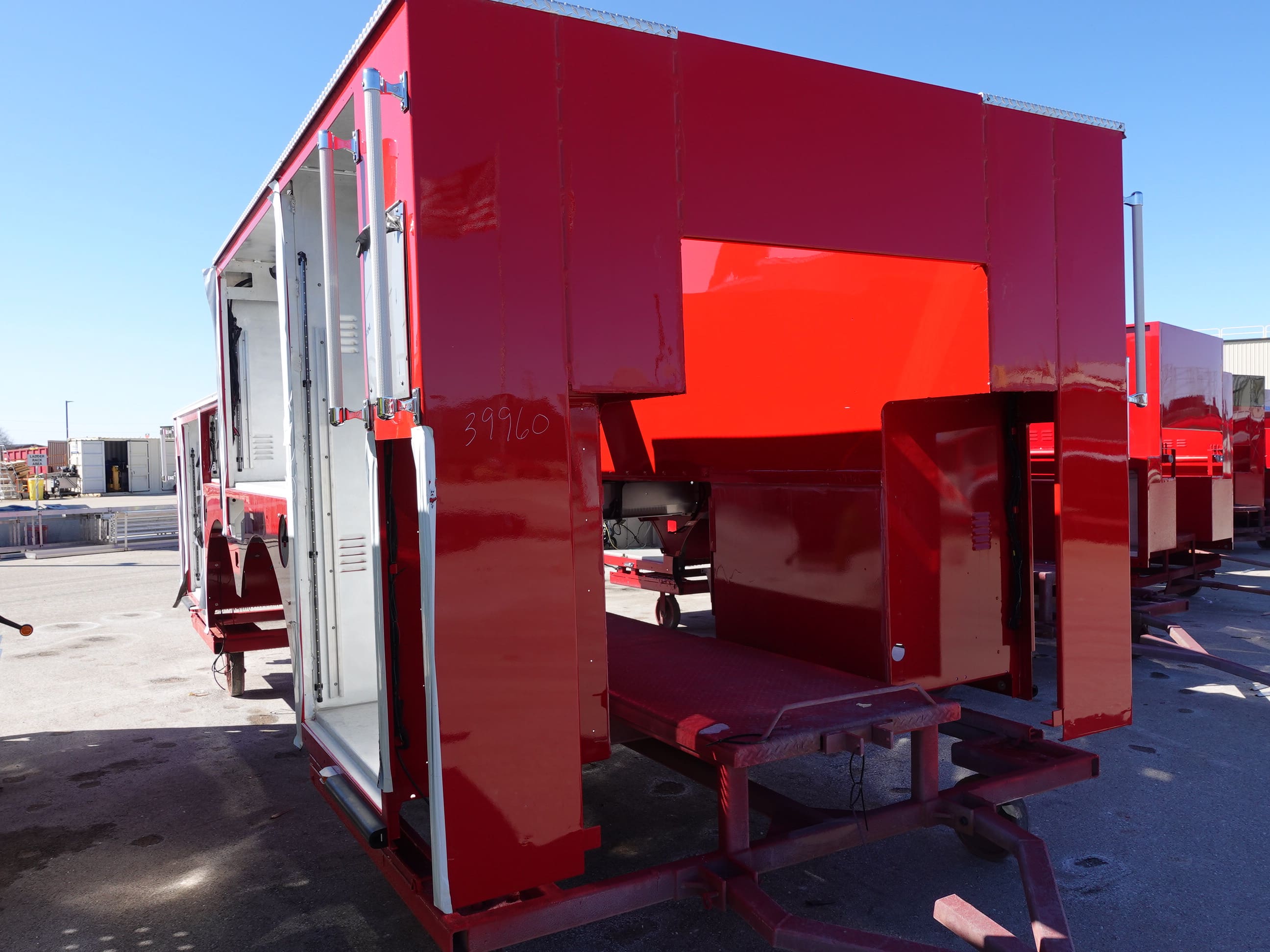

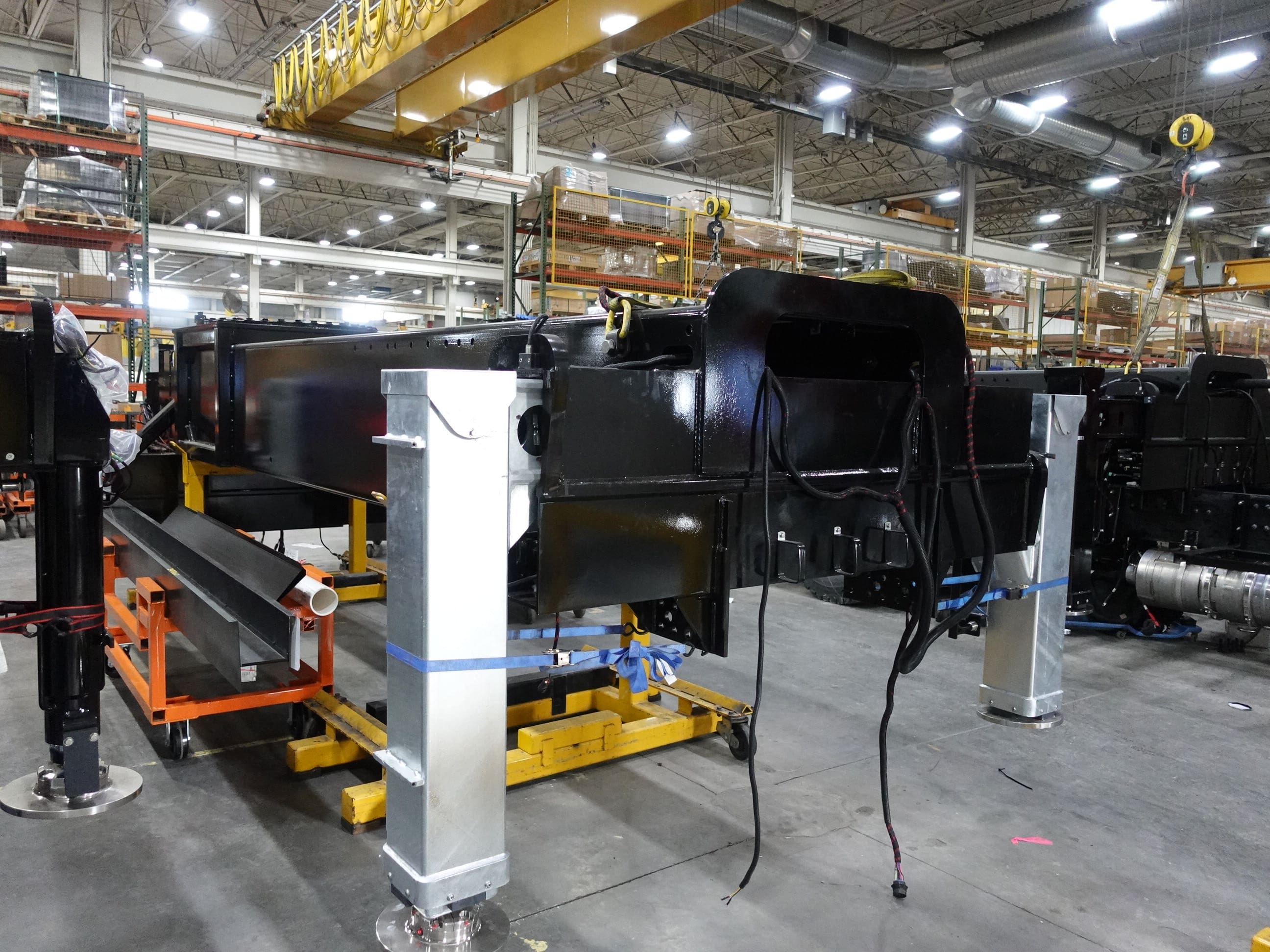

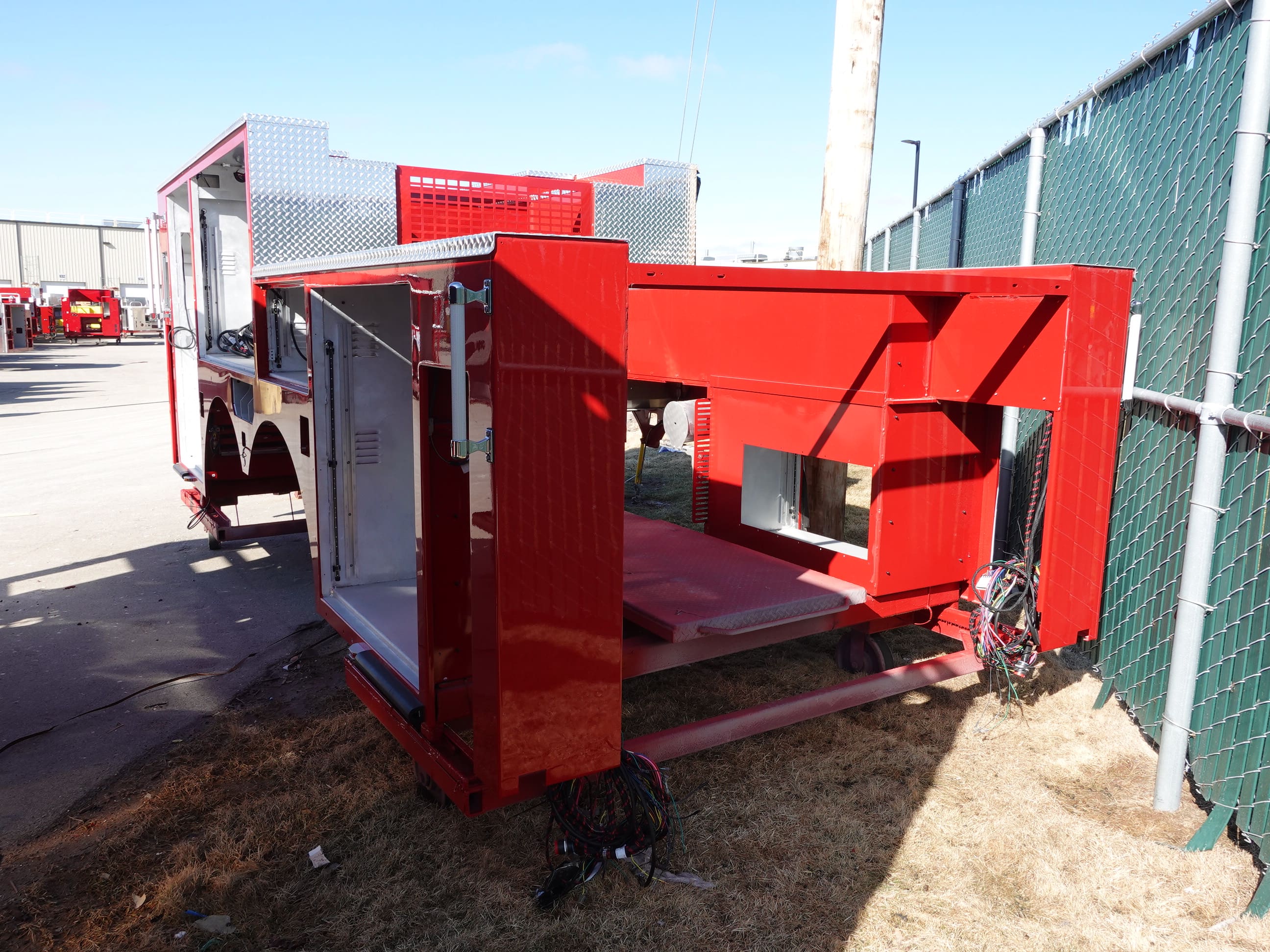

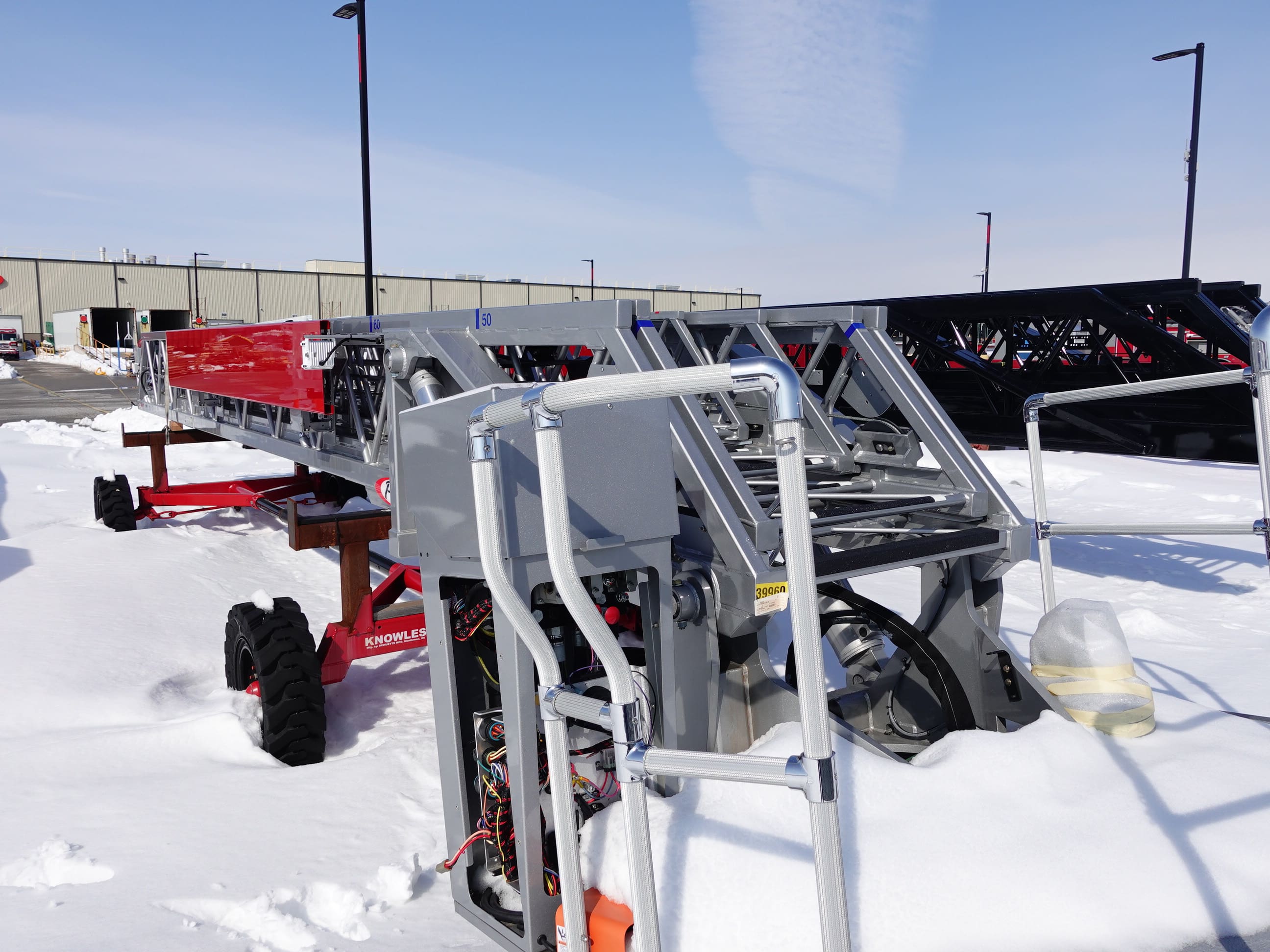

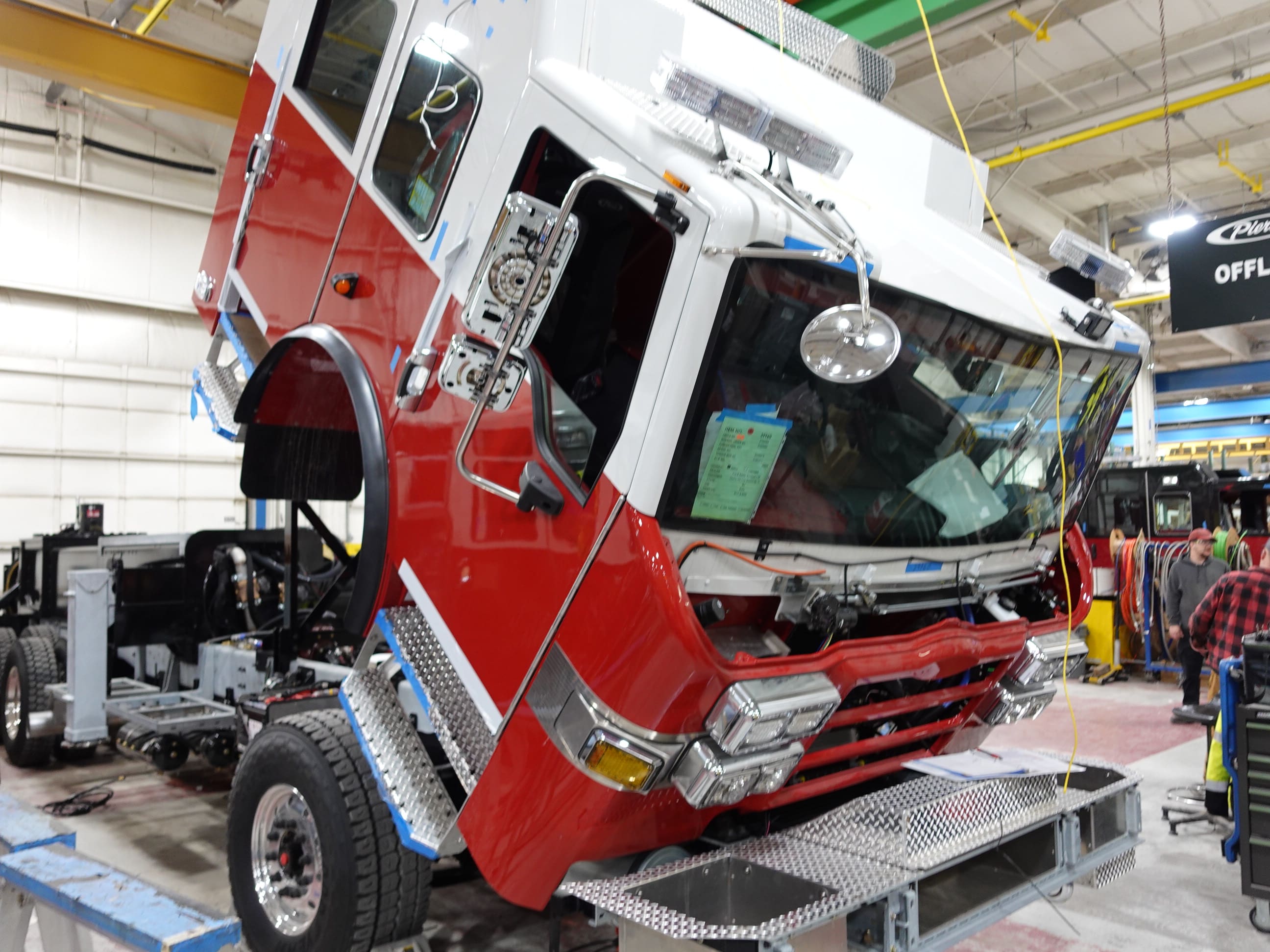

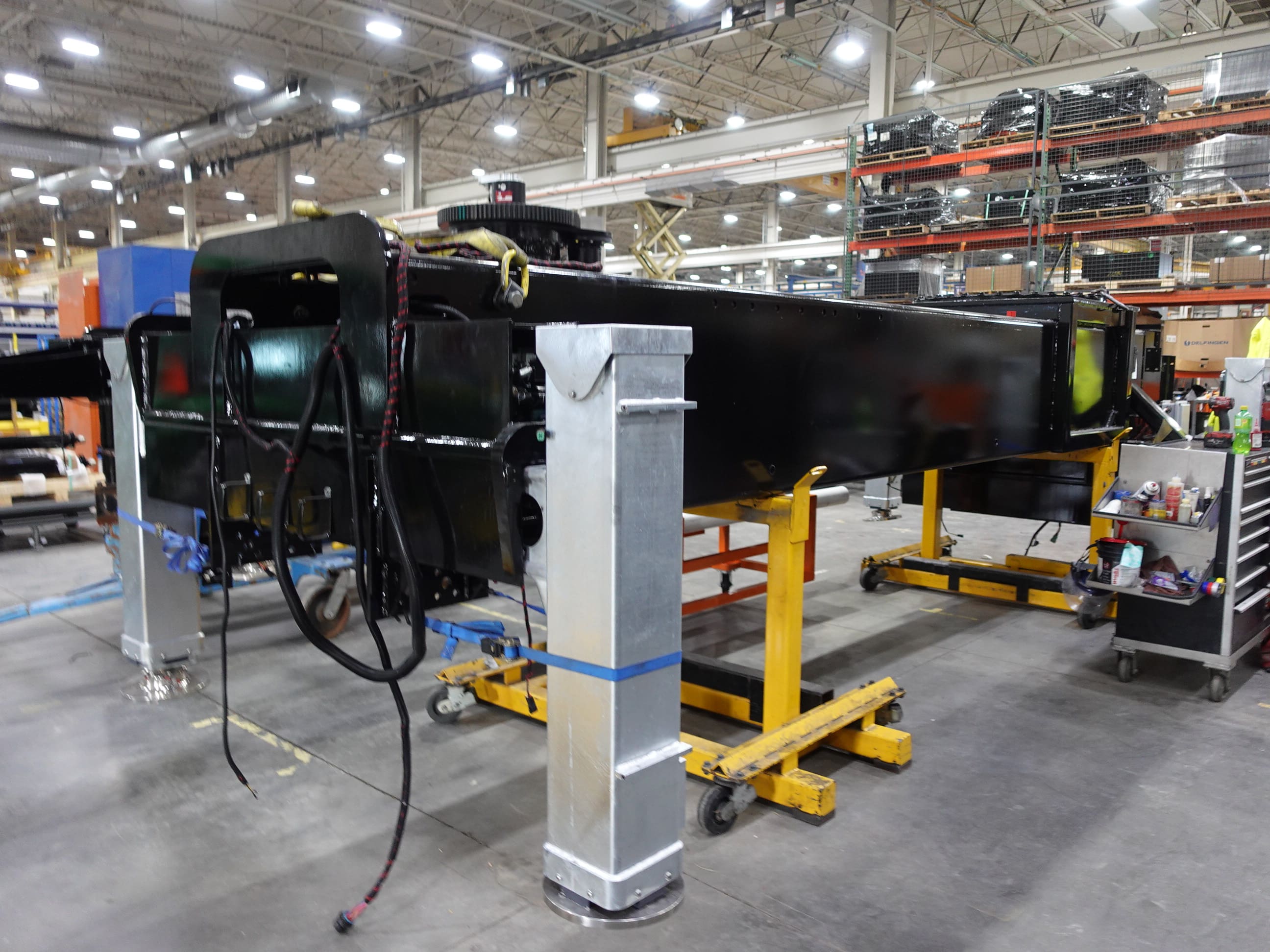

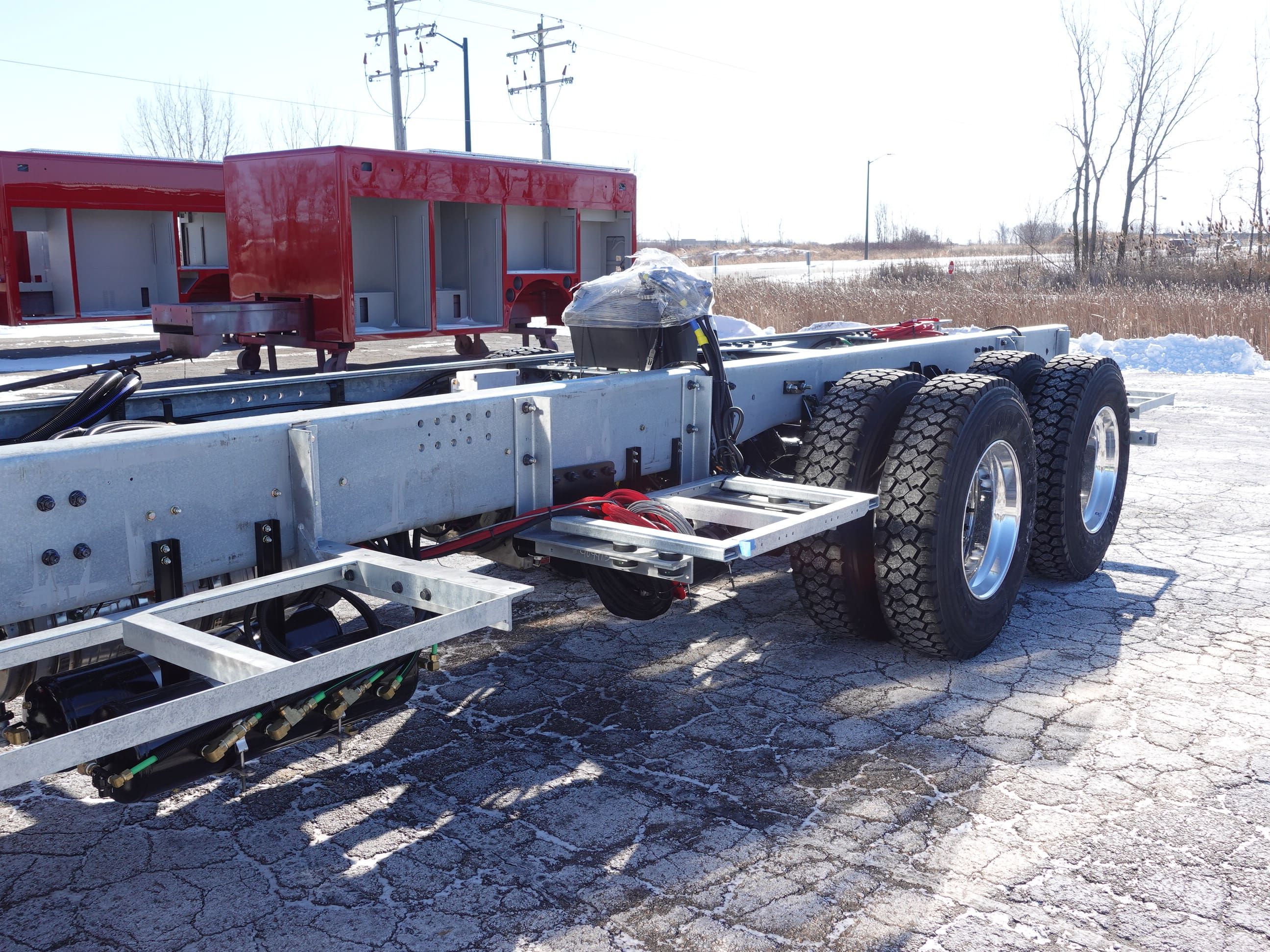

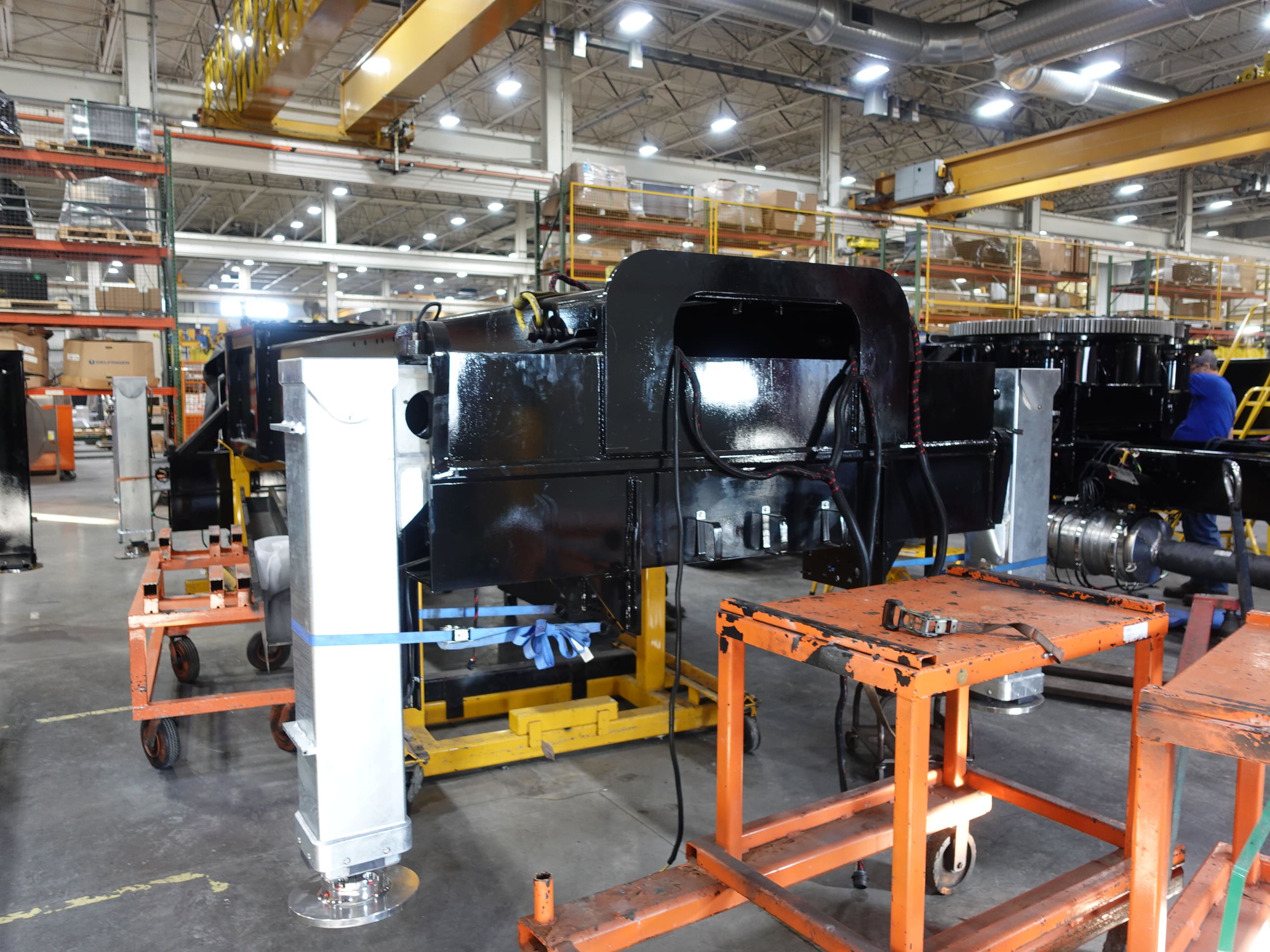

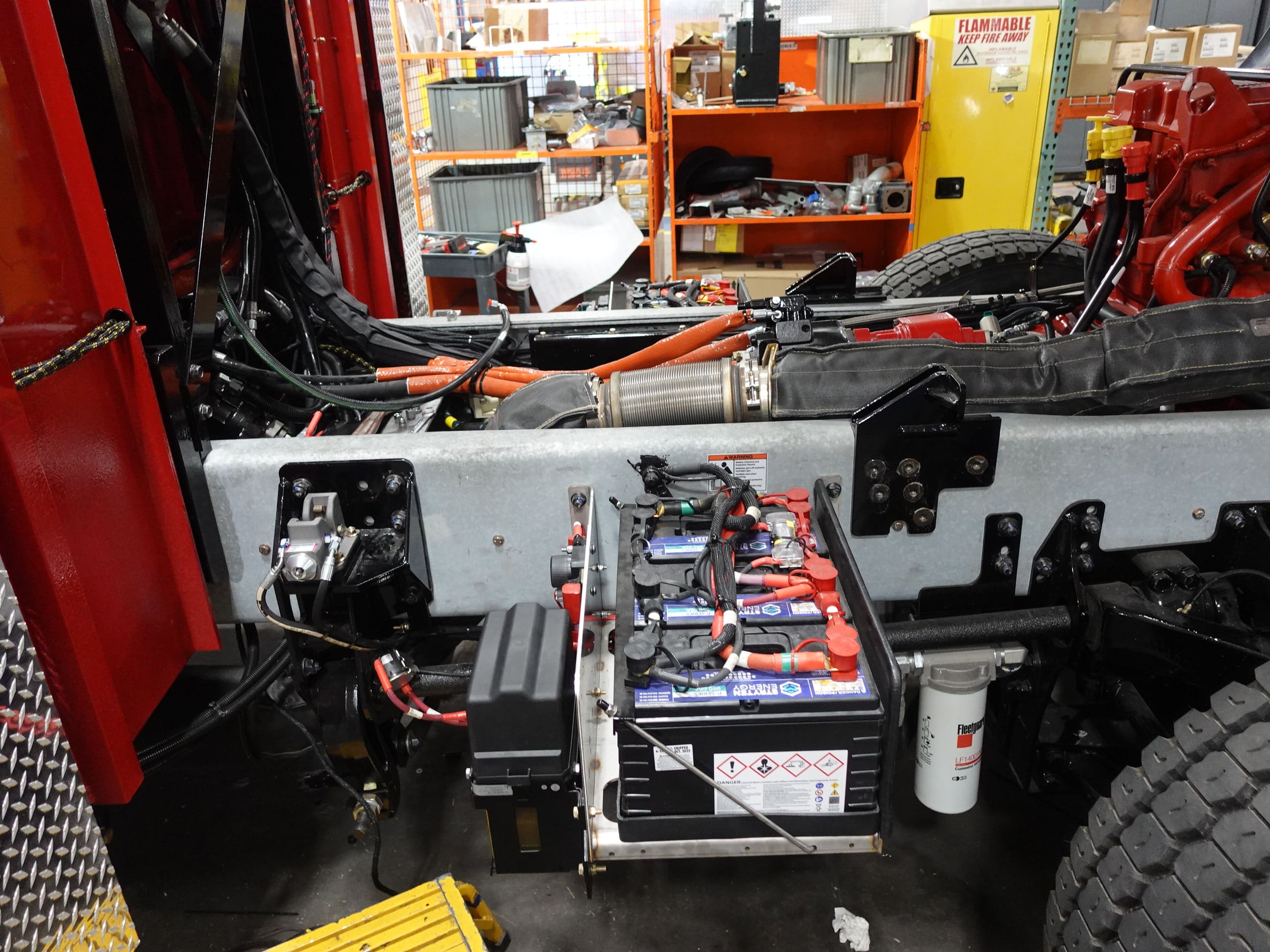

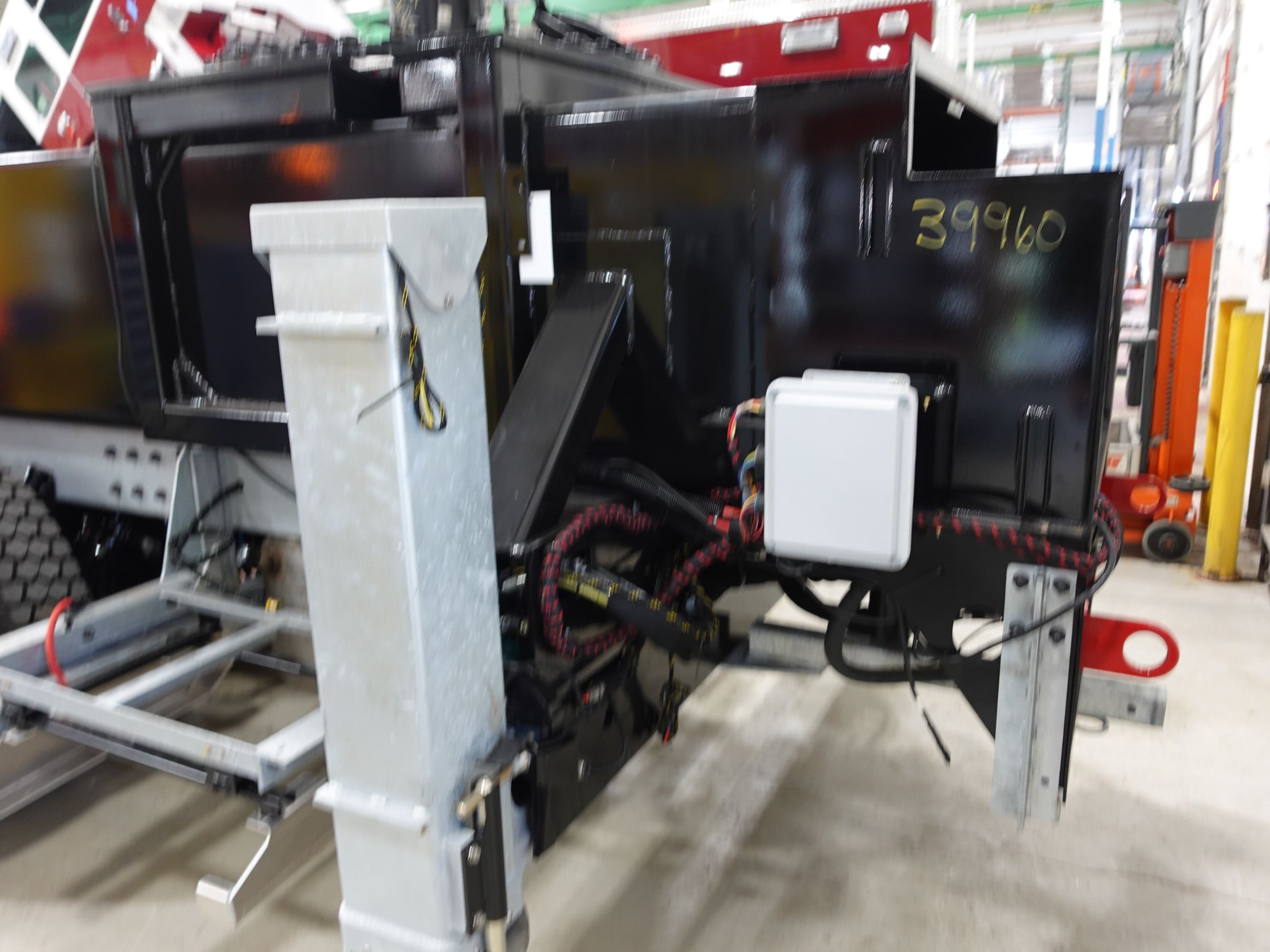

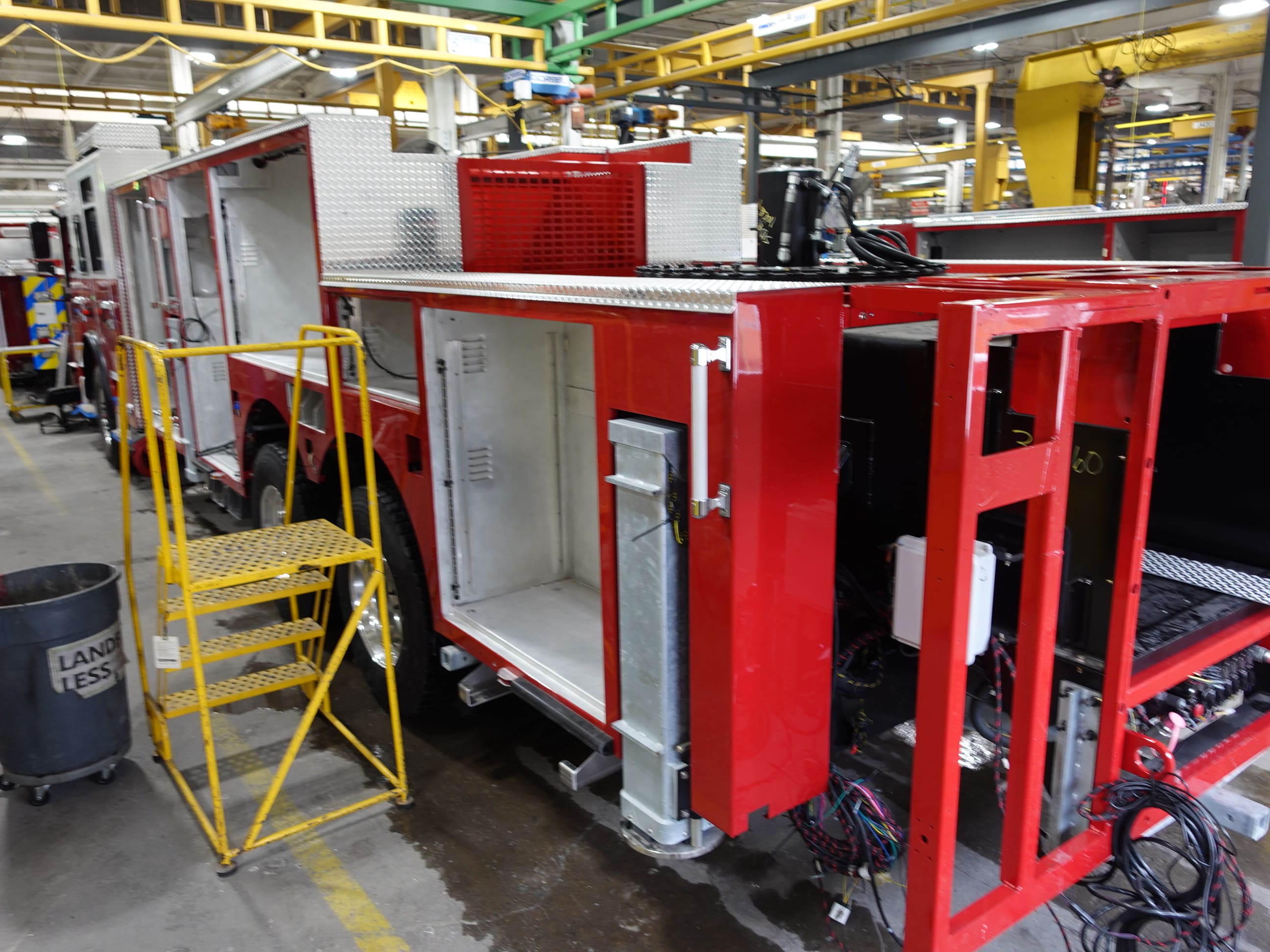

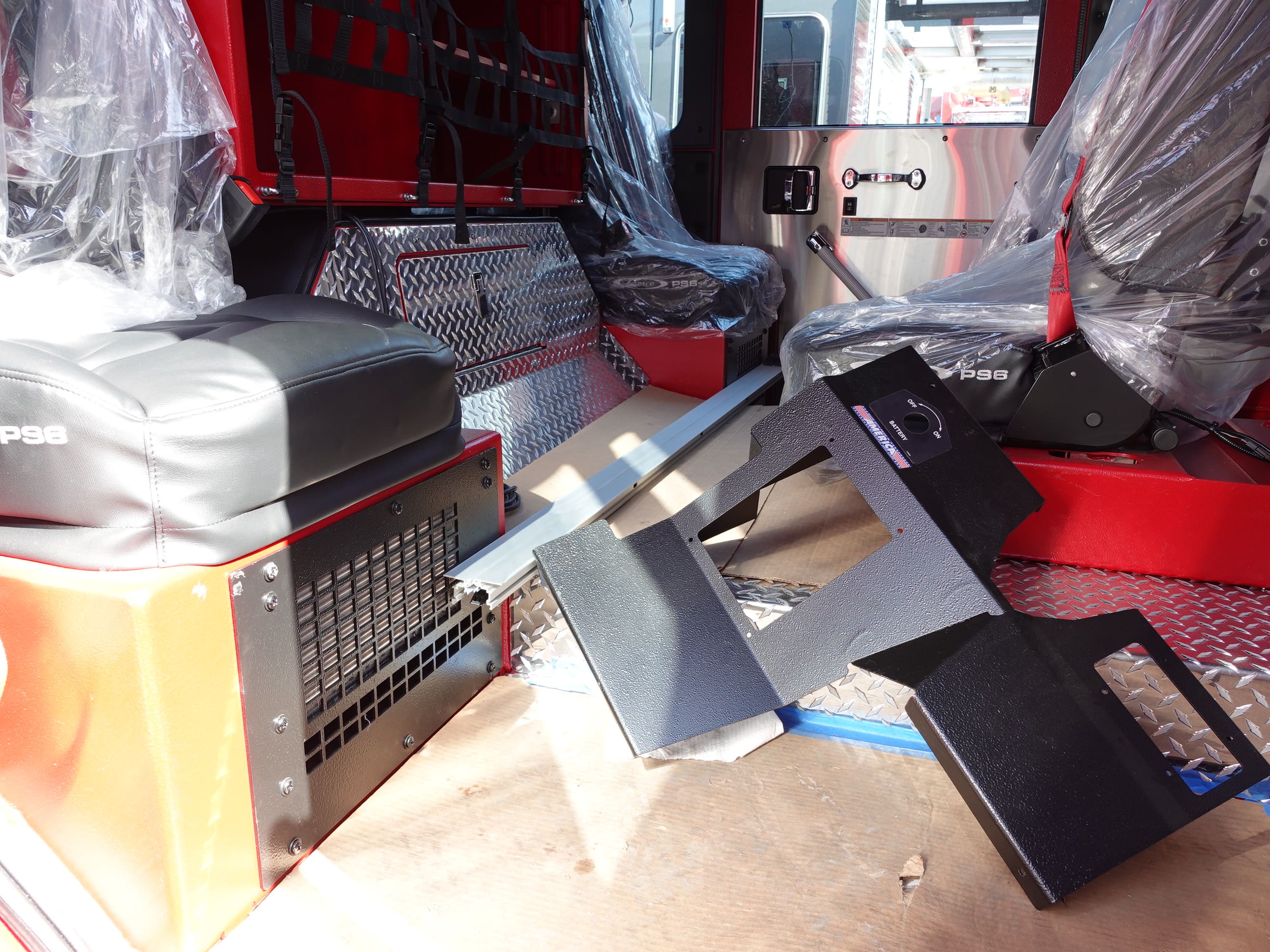

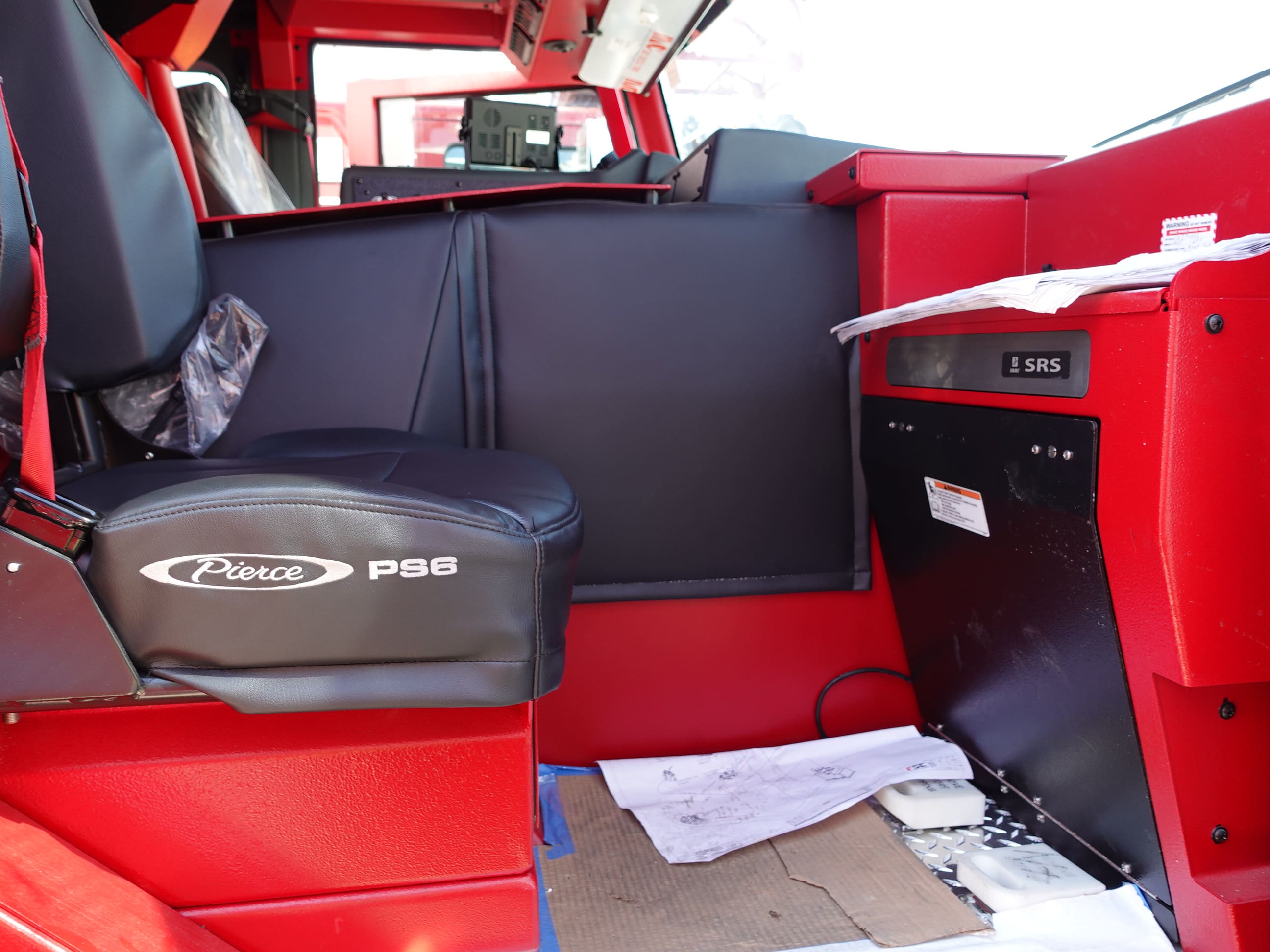

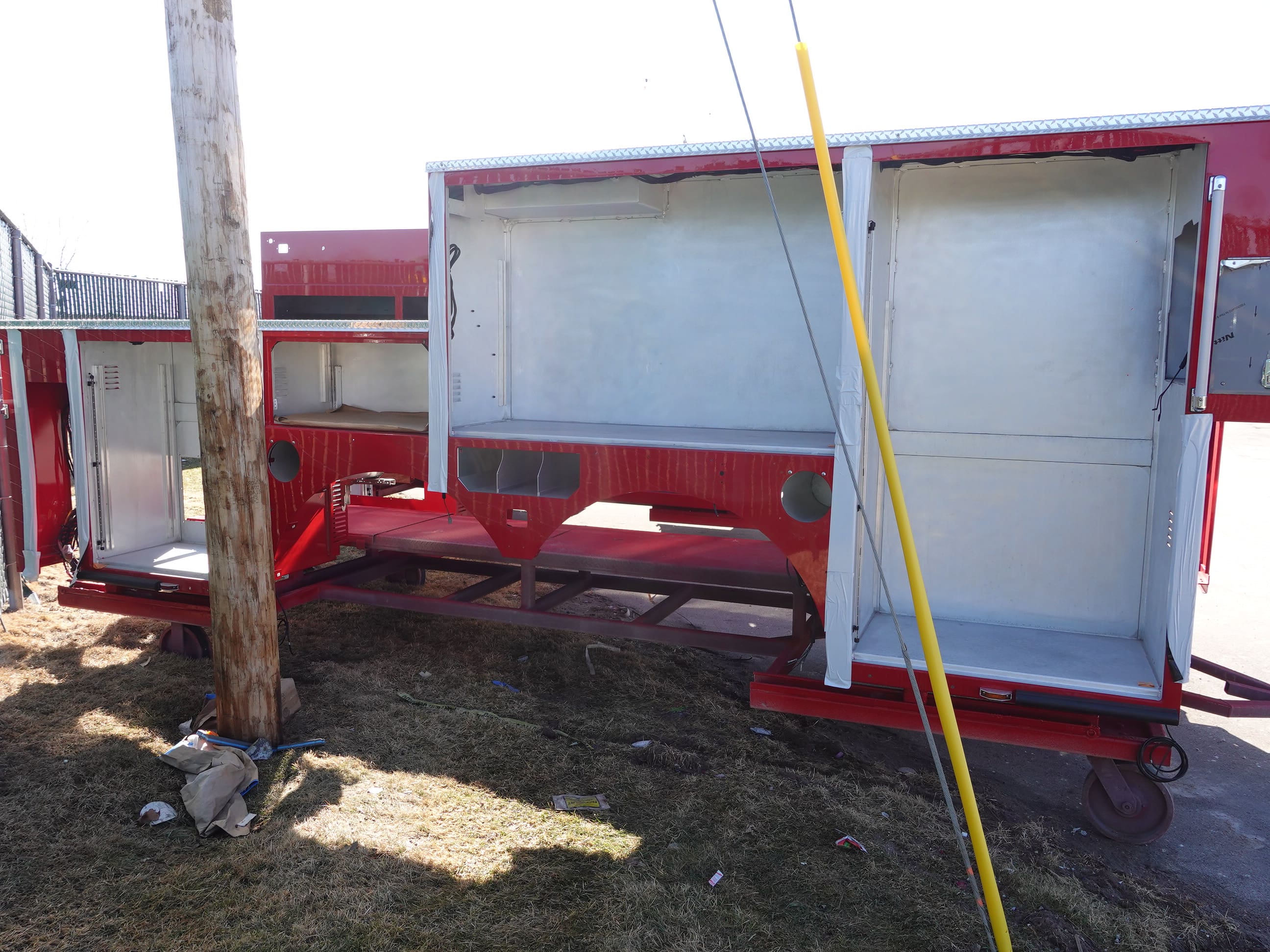

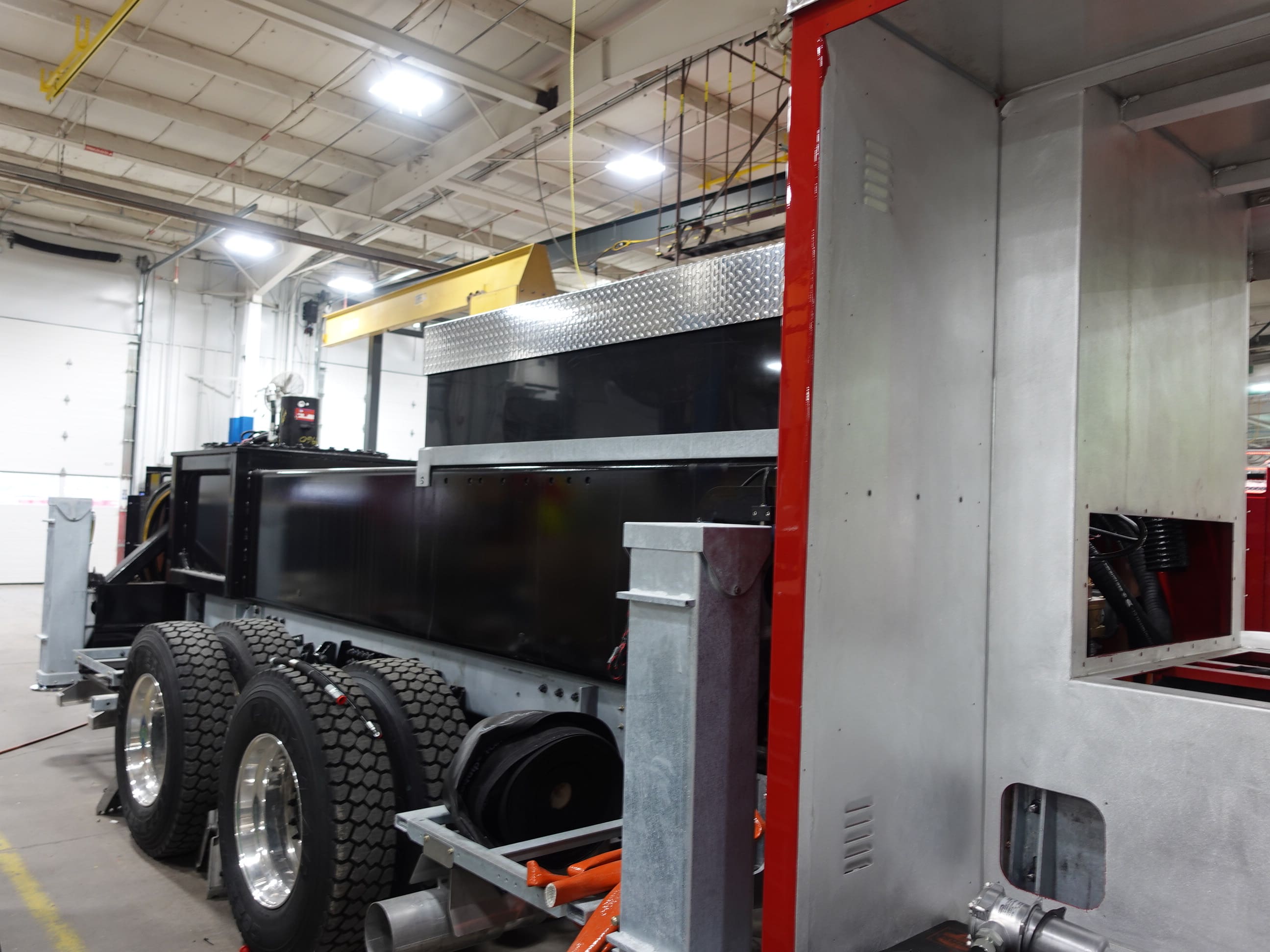

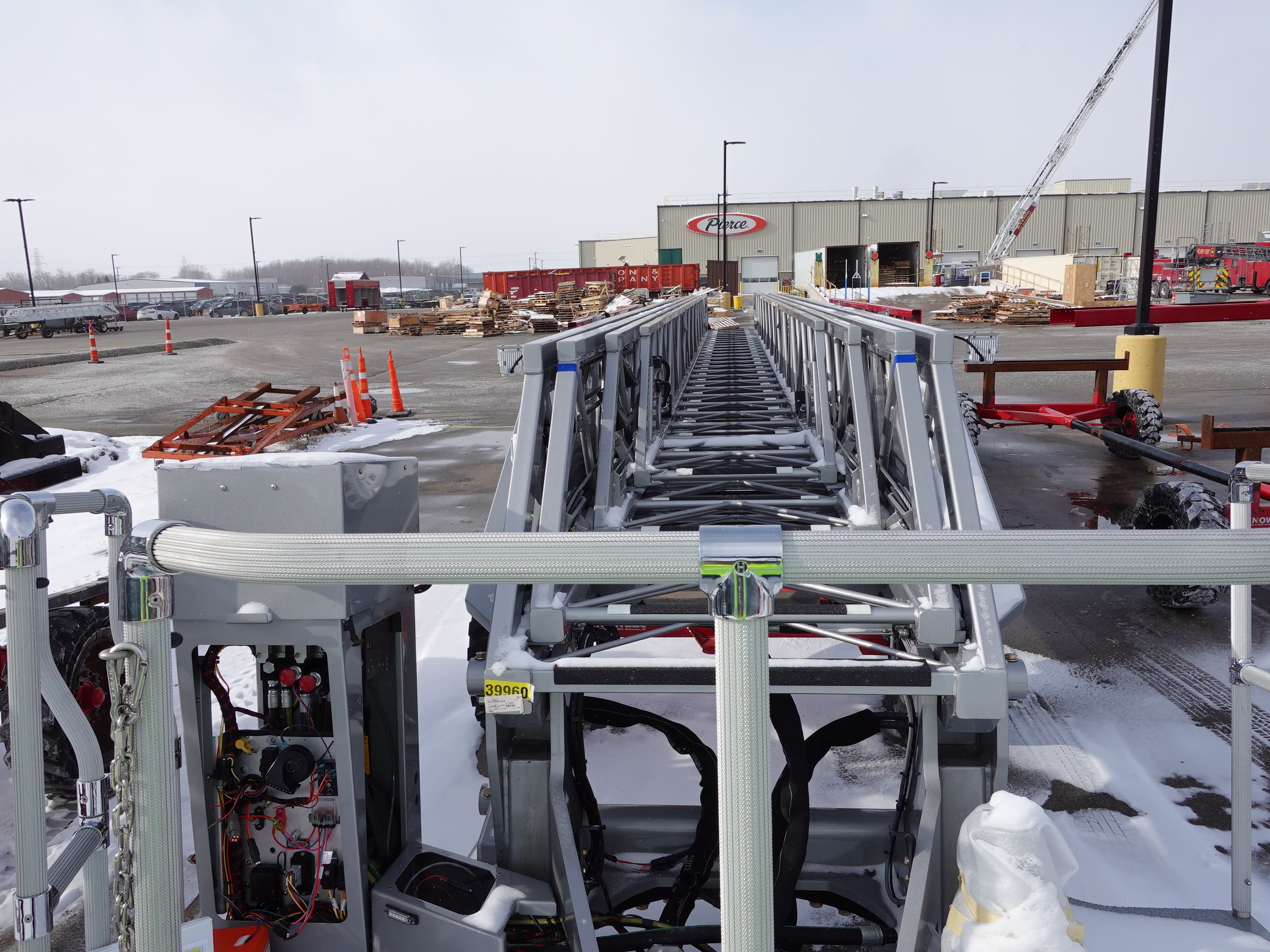

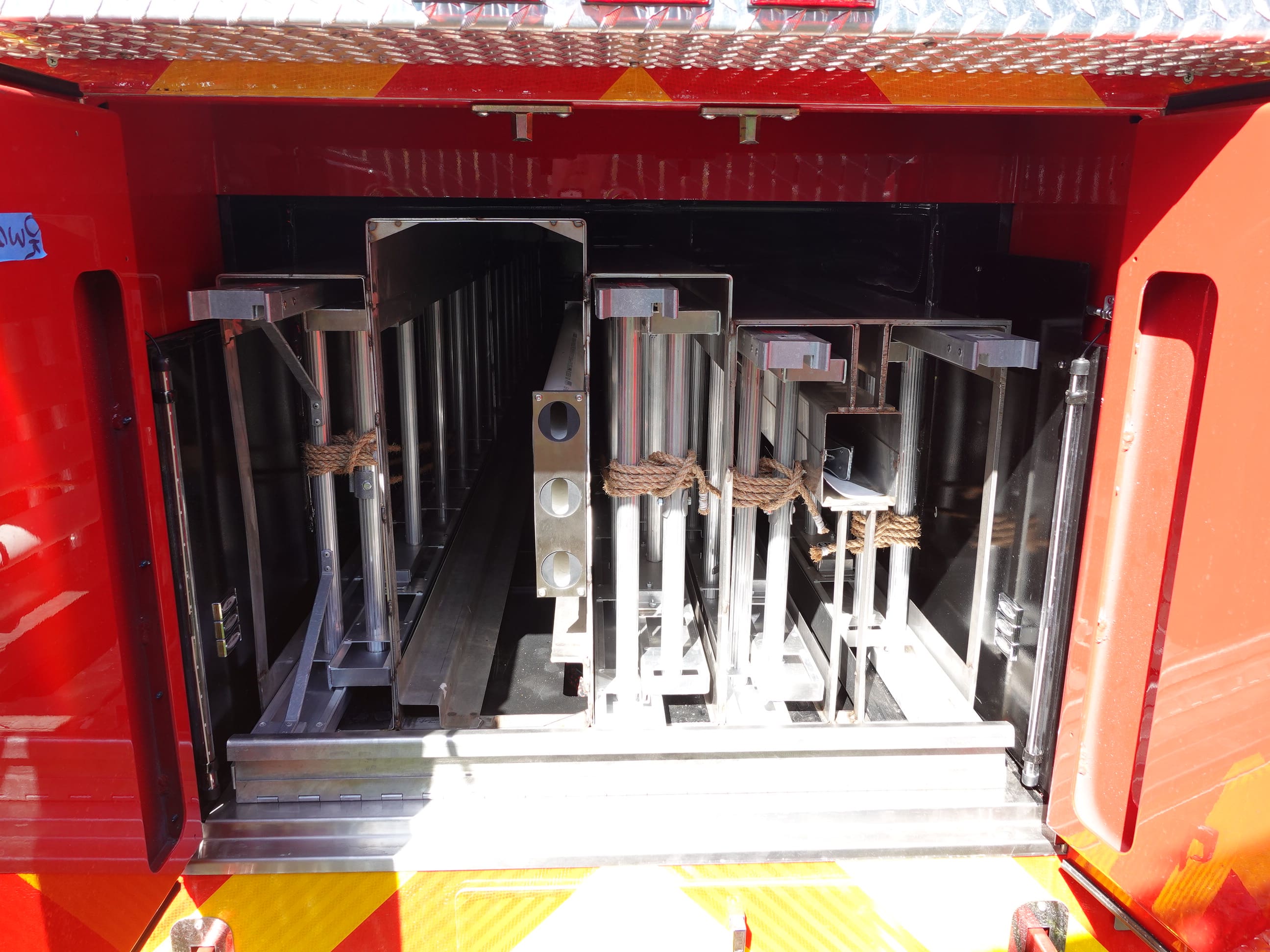

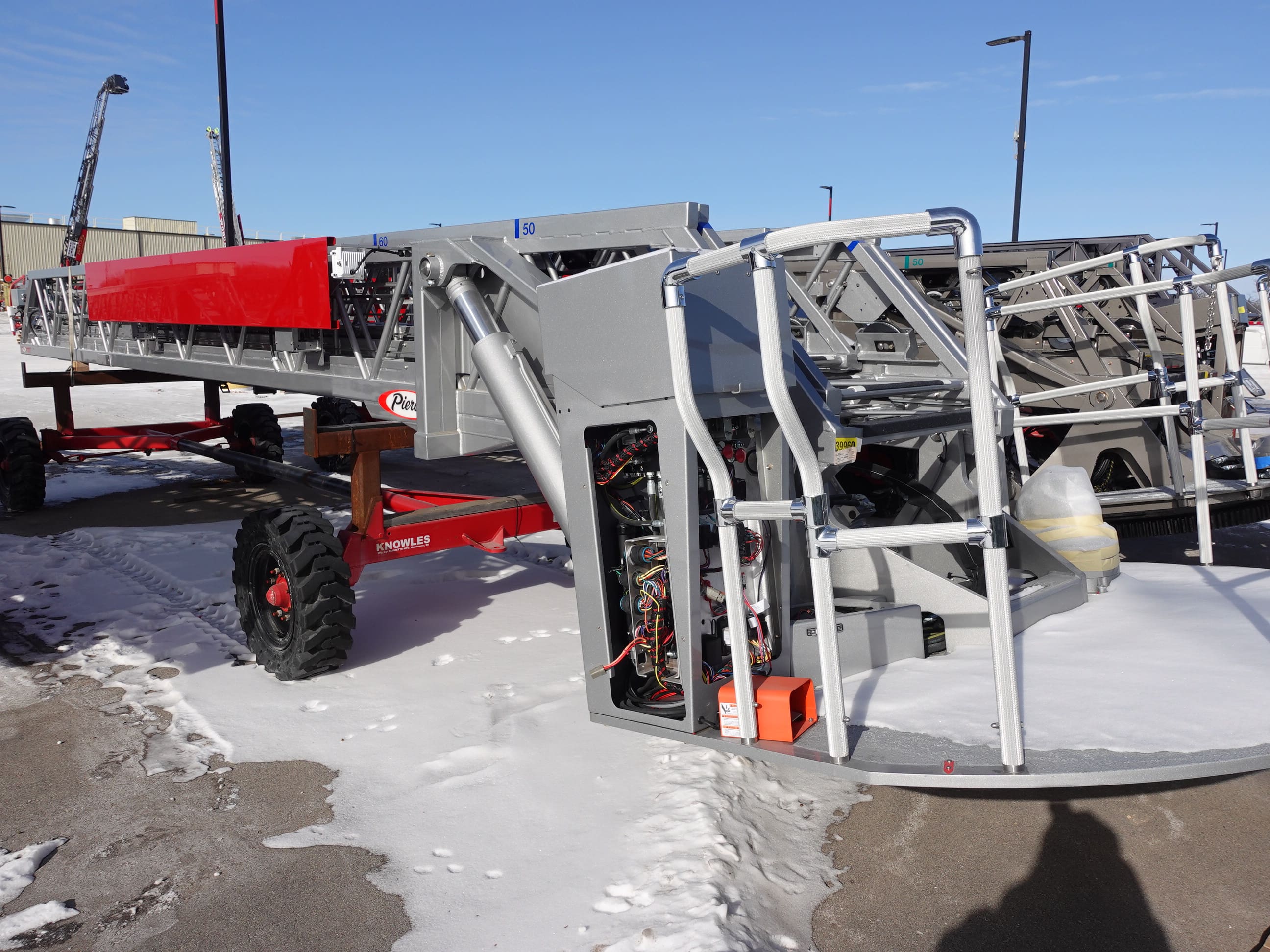

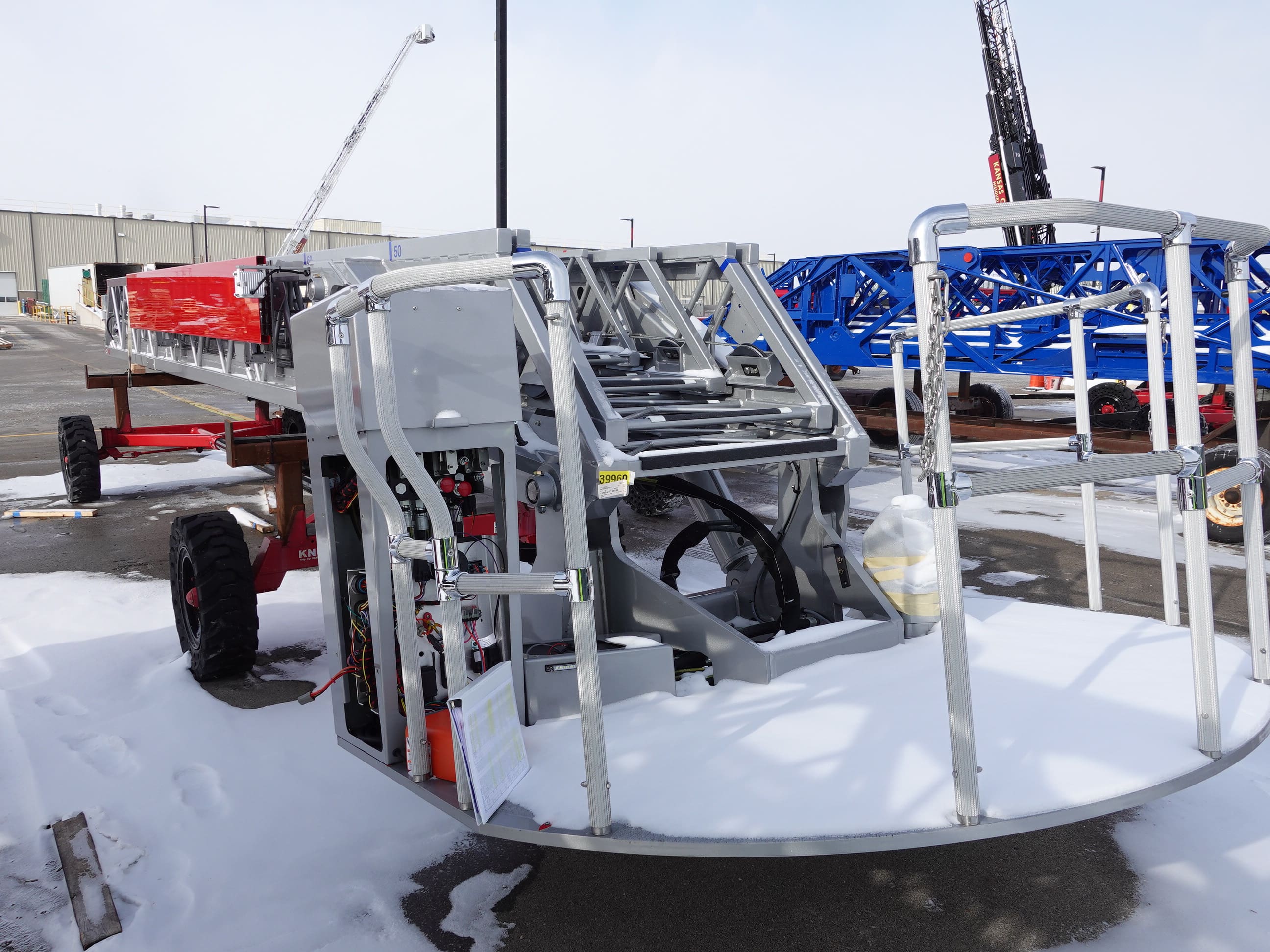

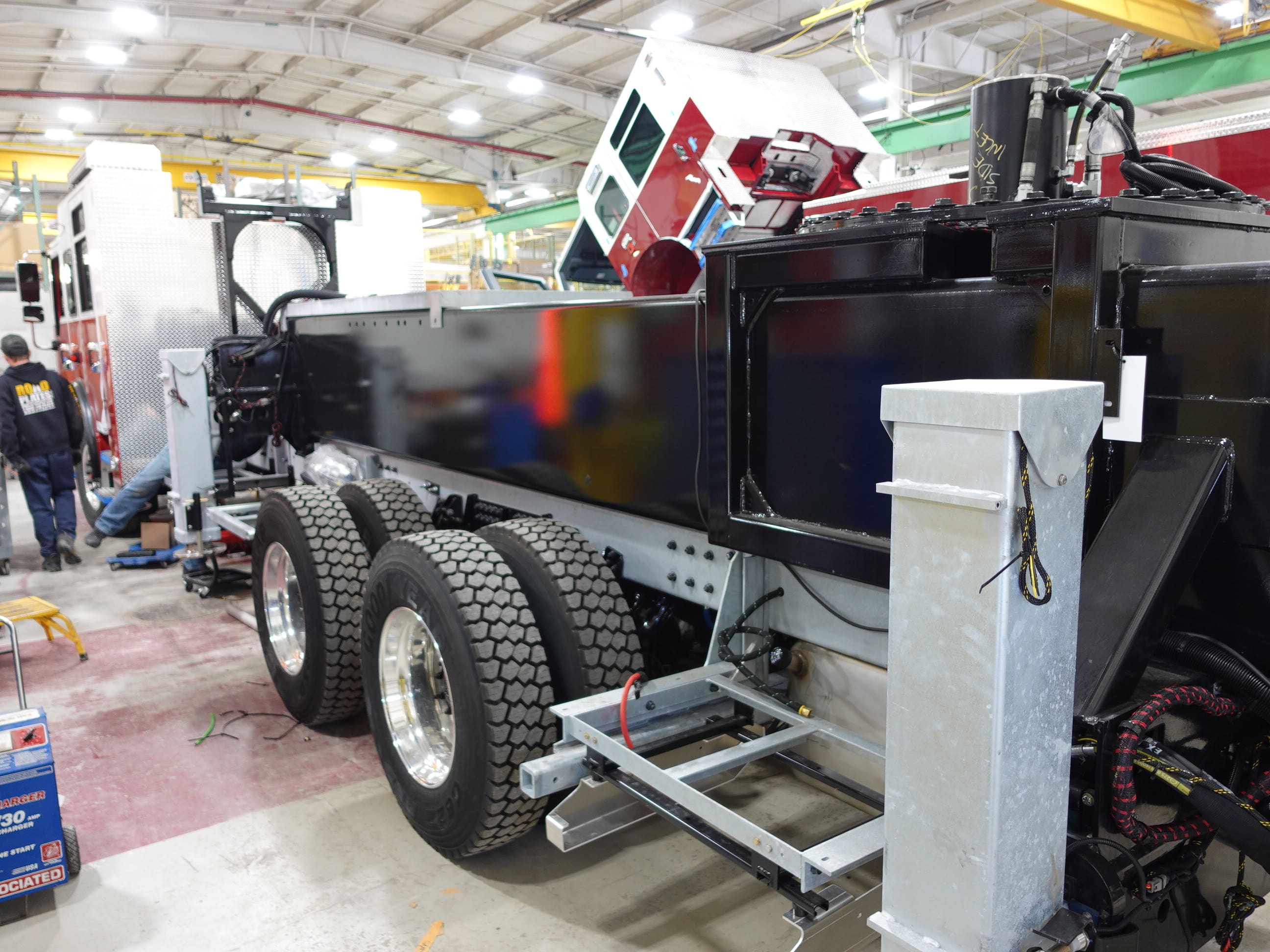

In this report, the body was merged with the chassis followed by the start of final assembly, while the aerial device remained staged.
03-13-26

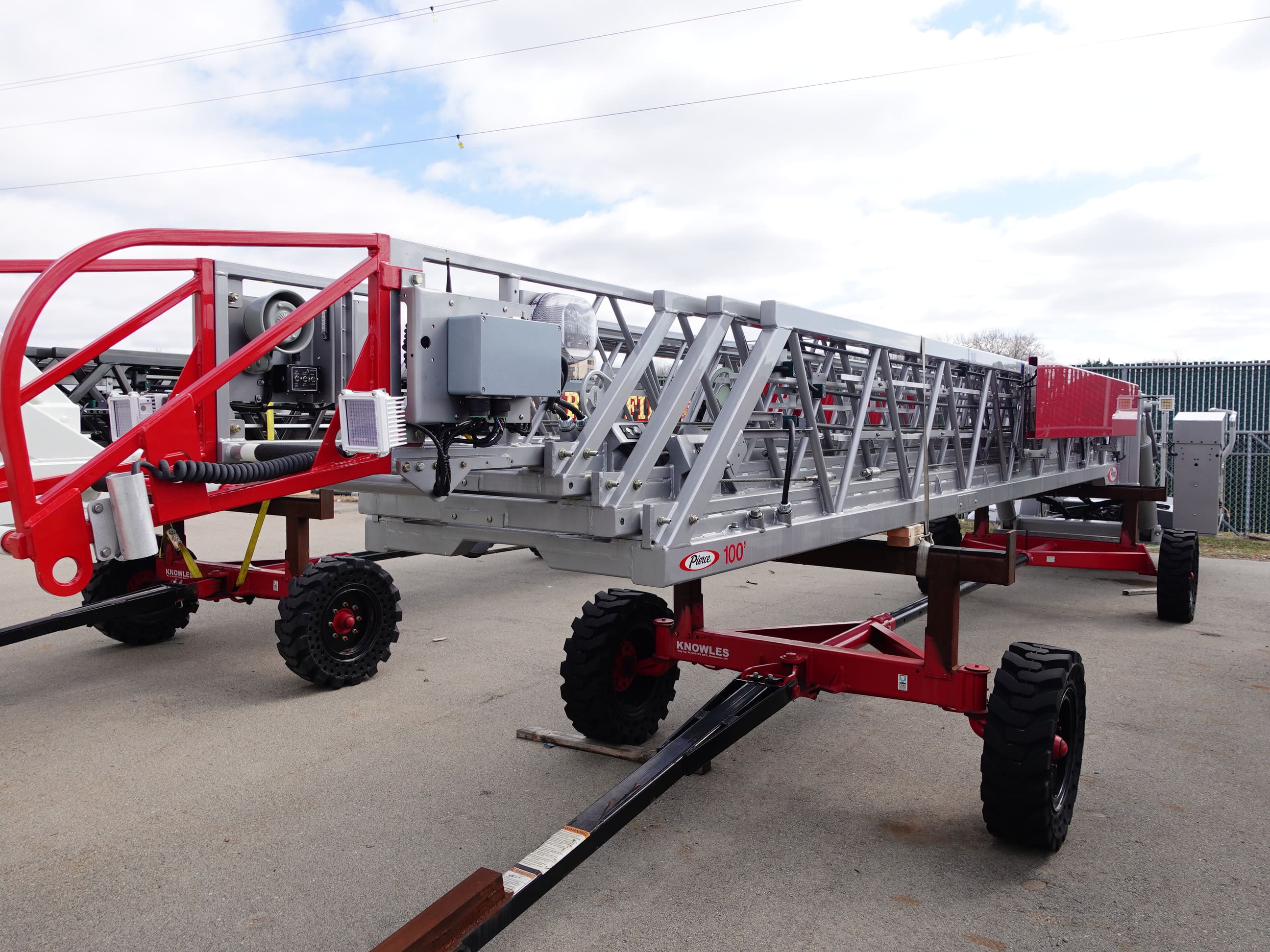

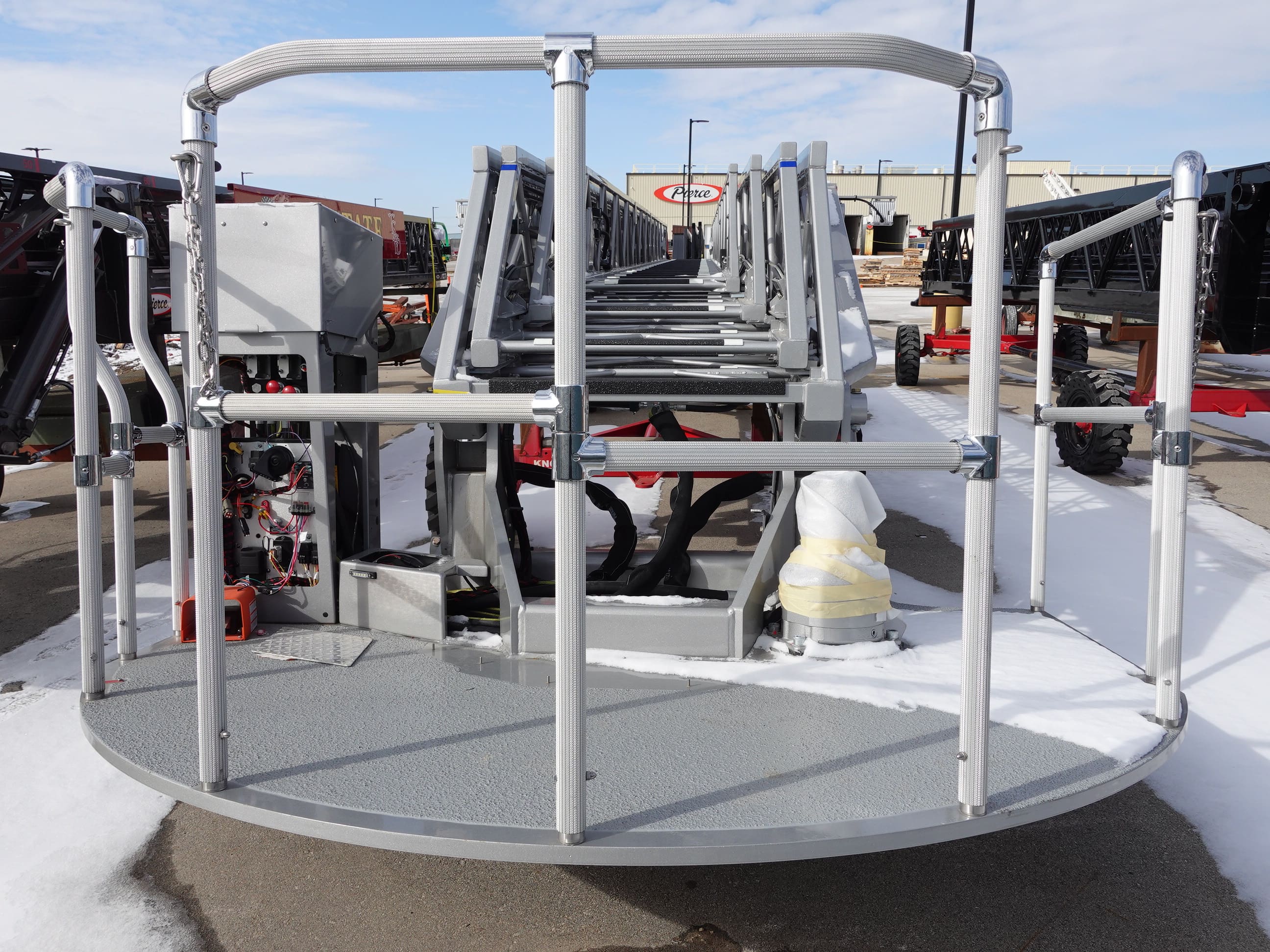

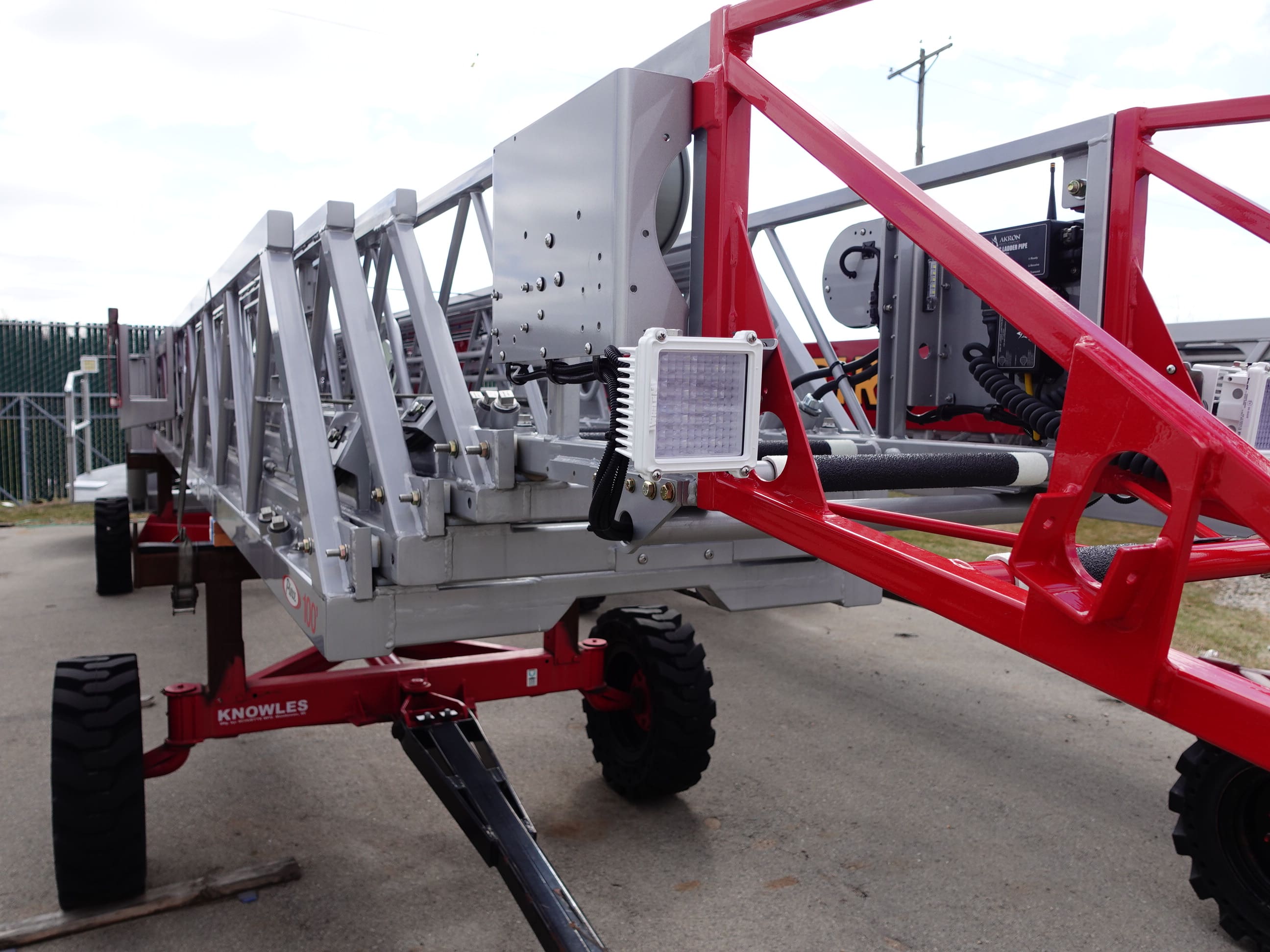

In this report, the transverse was merged with the chassis while the body and aerial device remained staged.
03-06-26

In this report, the chassis continued assembly while the transverse, body, and aerial device all remained staged.
02-27-26
In this report, the chassis continued some assembly in an offline area of production while the transverse, body, and aerial device all remained staged.
02-20-26
In this report, the chassis was staged to continue assembly while the transverse, body, and aerial device all remained staged.
02-13-26
In this report, the chassis was staged to continue assembly while the transverse, body, and aerial device all remained staged.
02-06-26

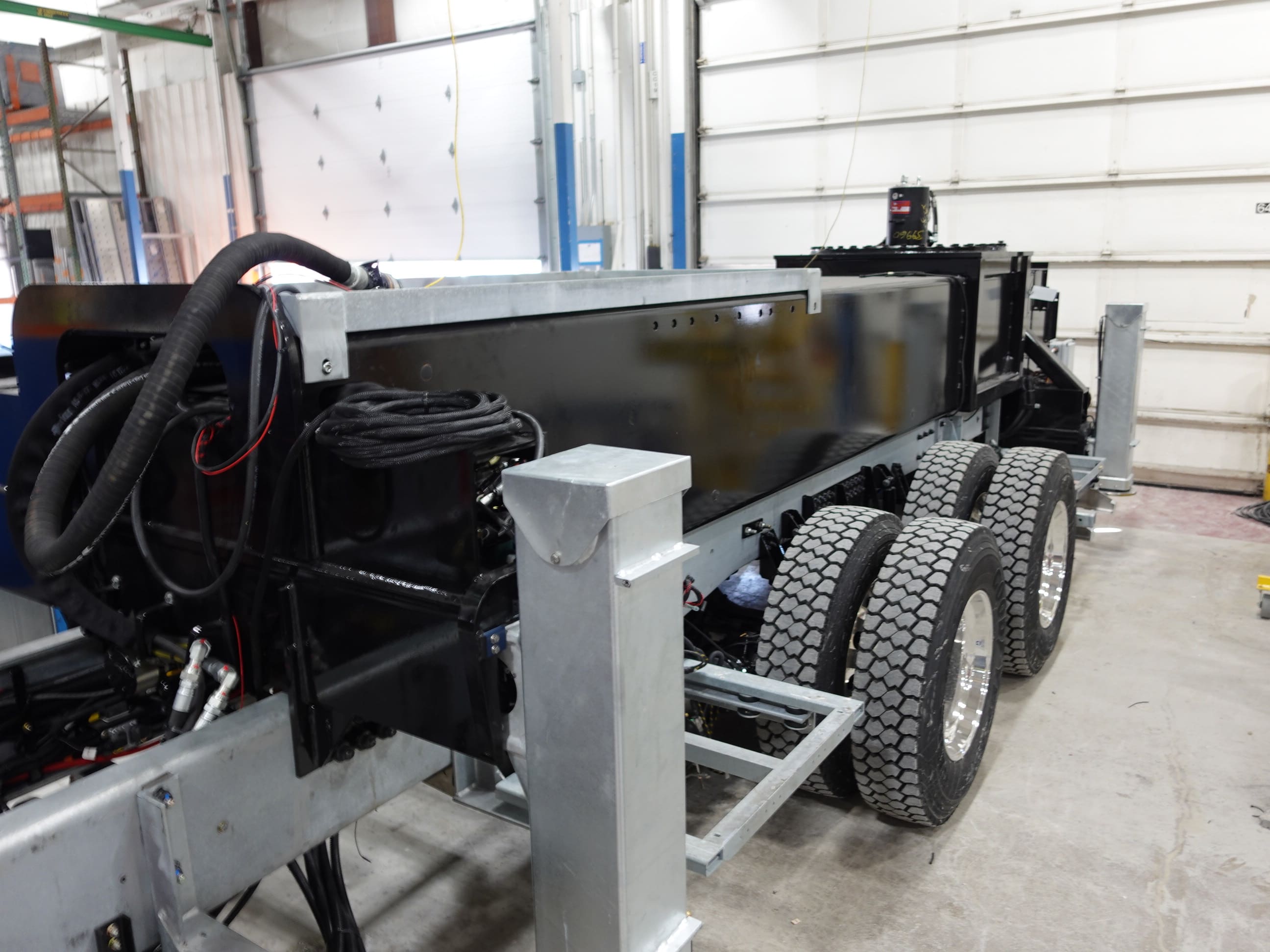

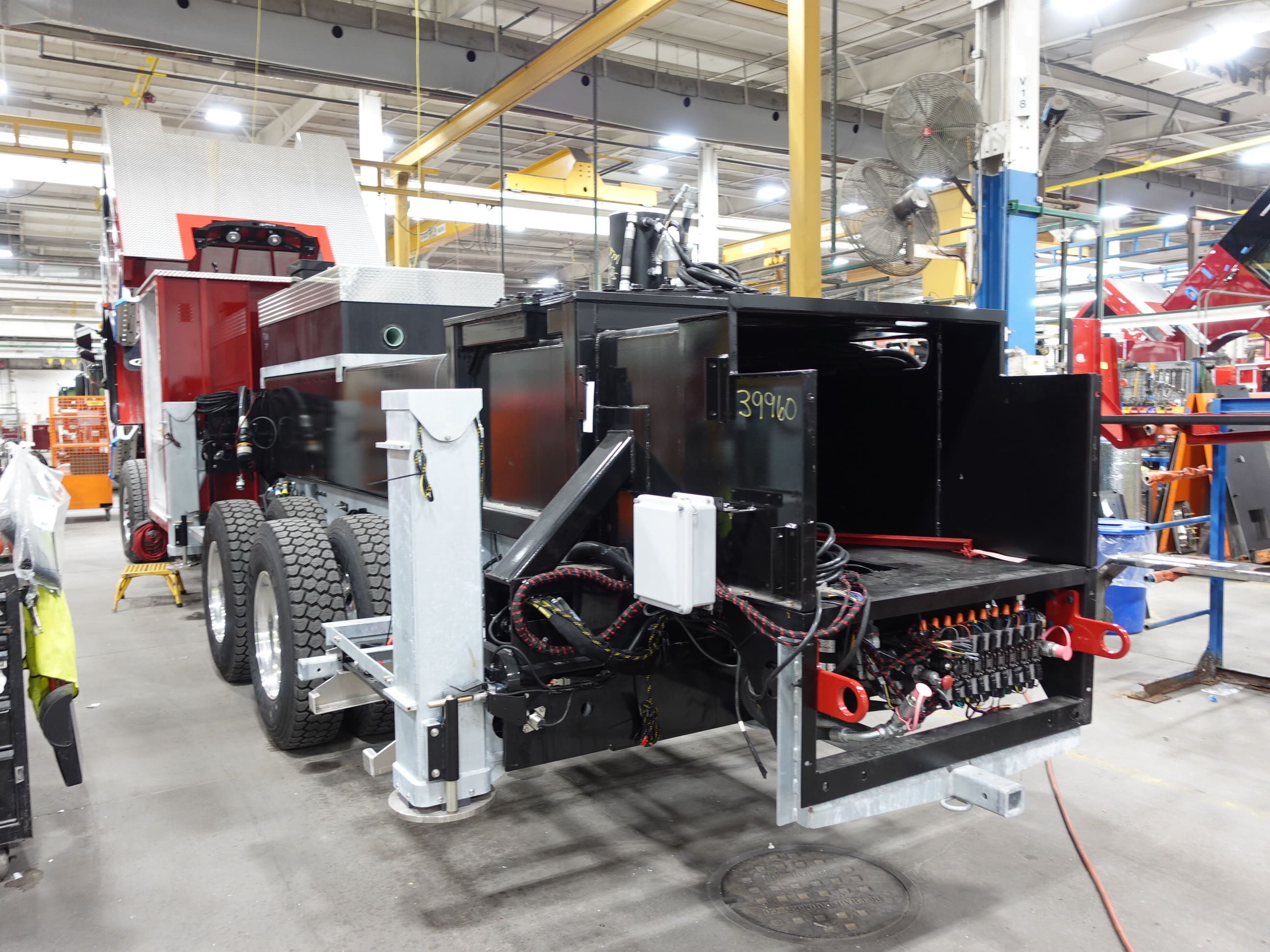

In this report, the torque box was installed on the chassis and assembly continued, and the transverse, body, and aerial device remained staged.
01-30-26
In this report, the chassis remained staged for torque box installation, the transverse remained staged, the torque box continued initial assembly, and the body and aerial device remained staged.
01-23-26
In this report, the chassis was staged for torque box installation, the transverse remained staged, the torque box continued initial assembly, and the body and aerial device remained staged.
