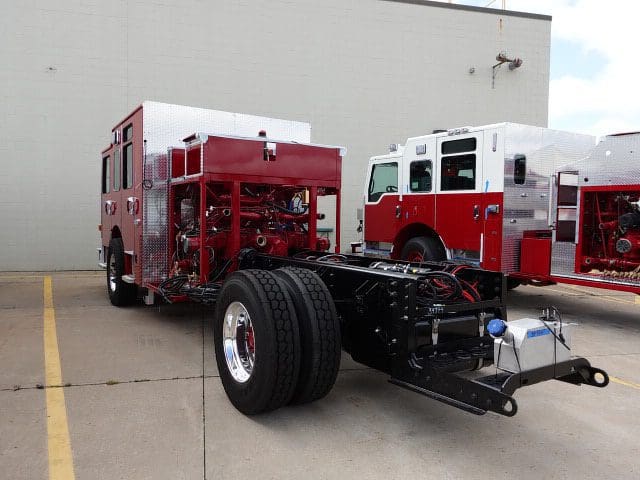

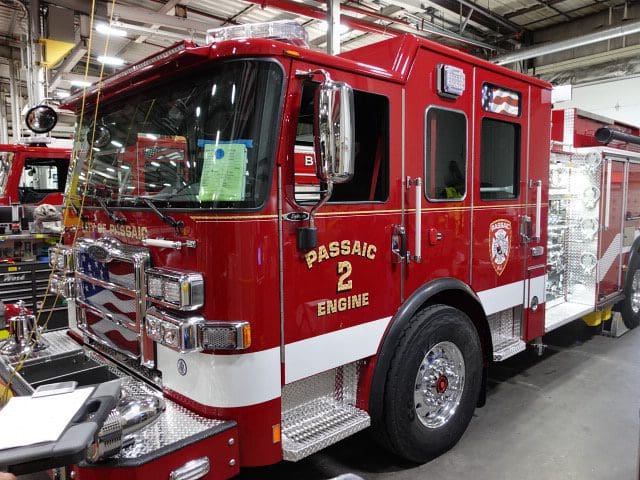

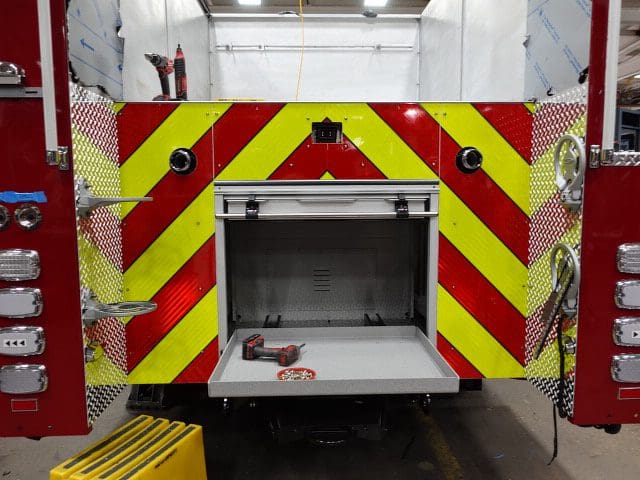

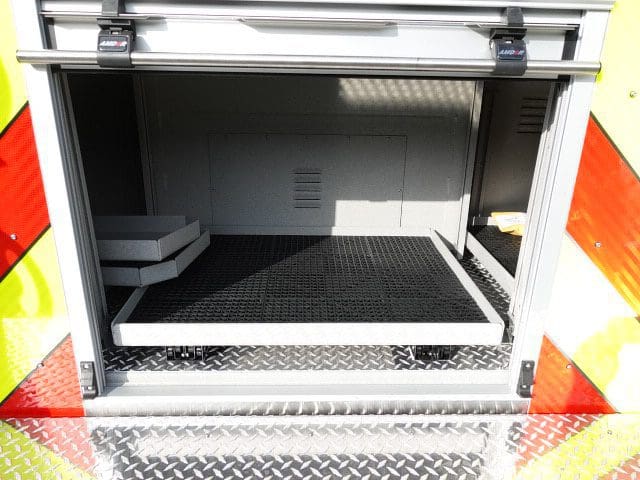

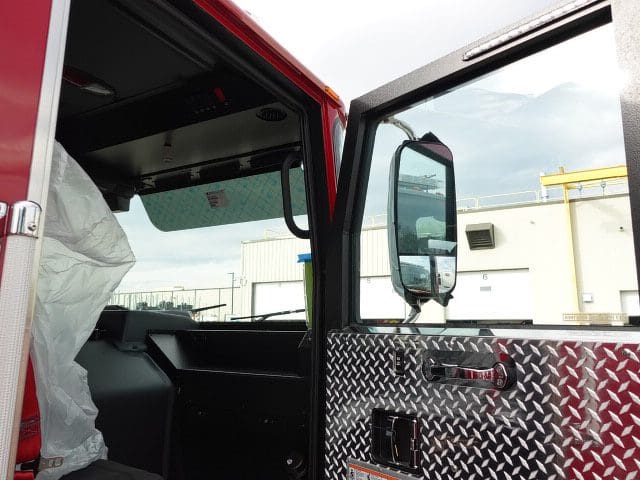

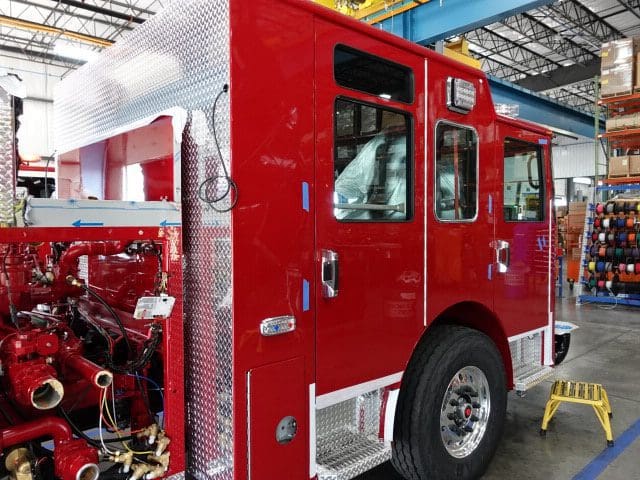

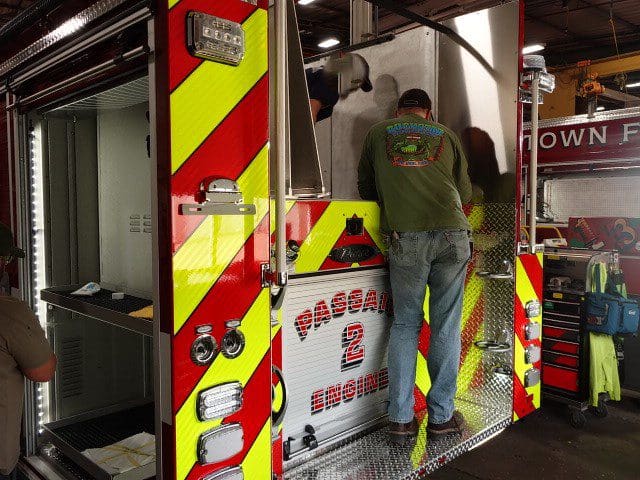

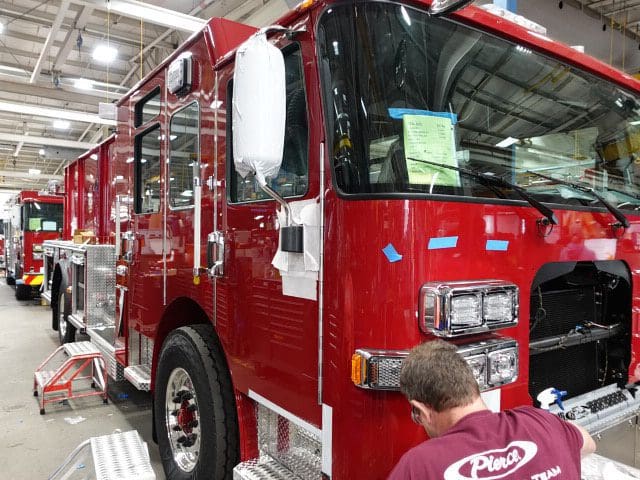

10-13-23

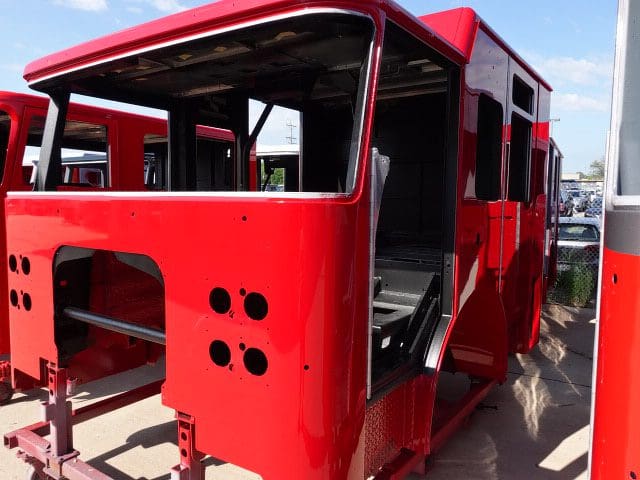

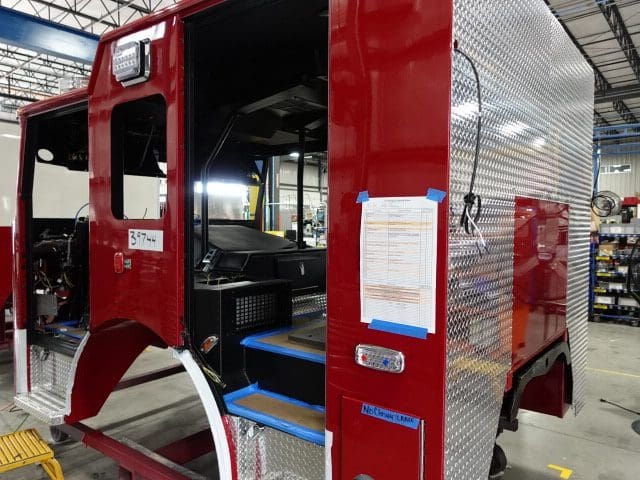

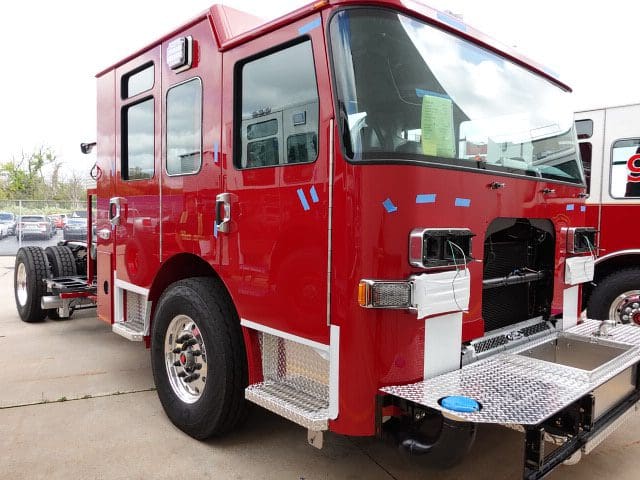

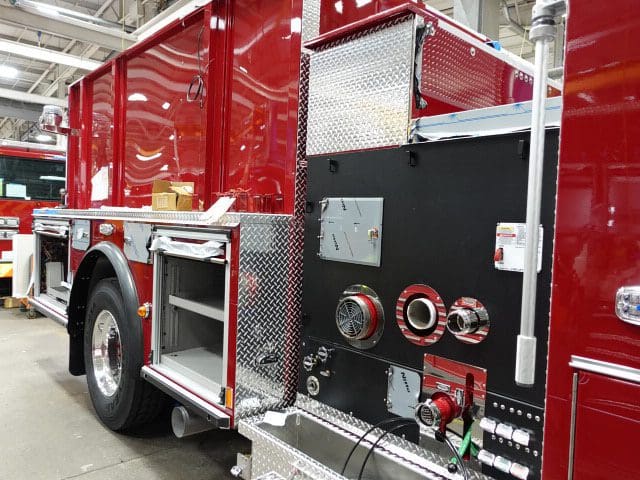

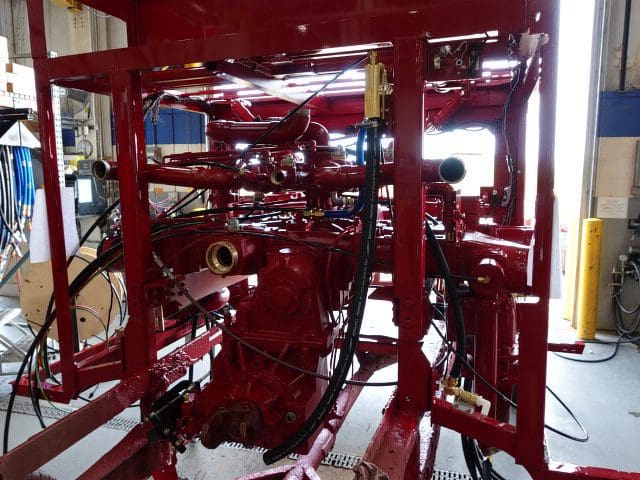

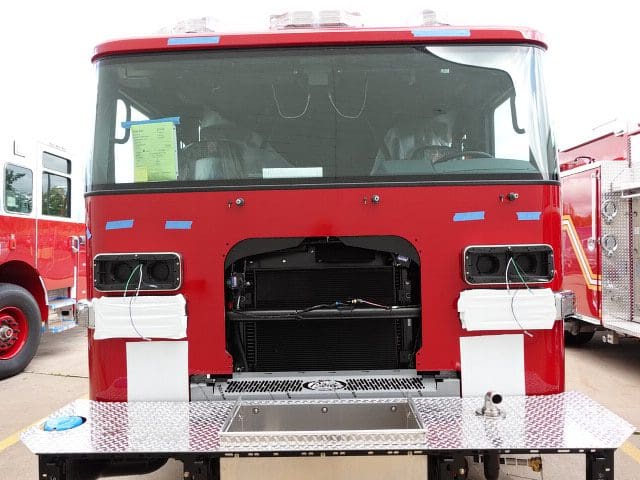

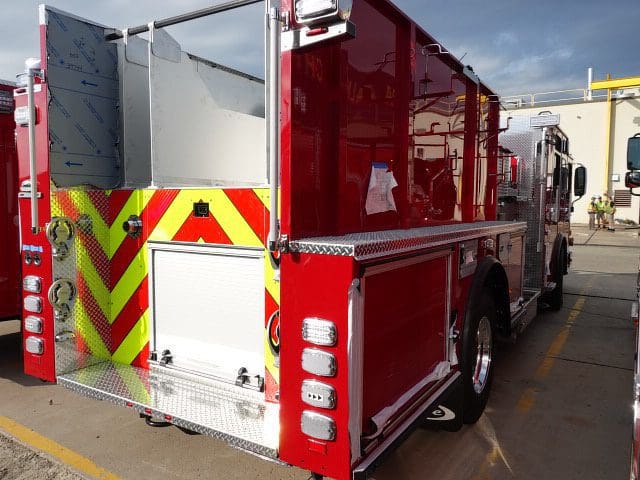

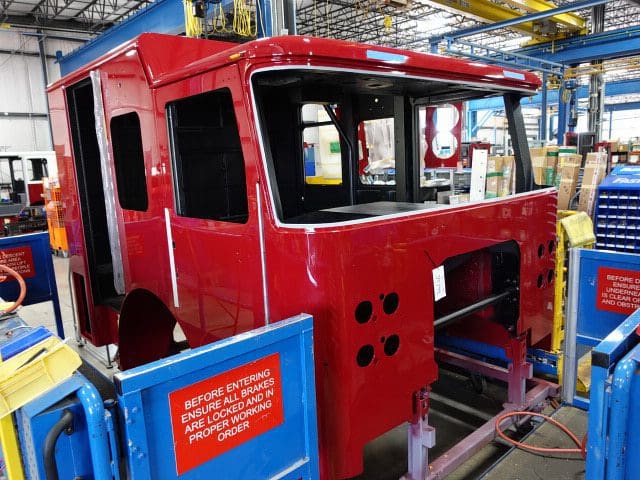

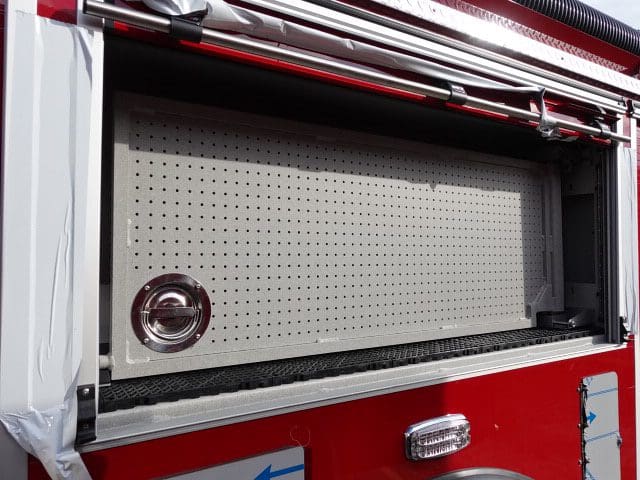

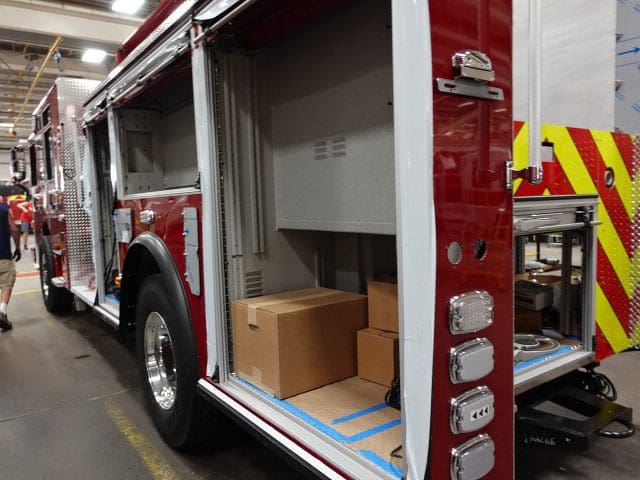

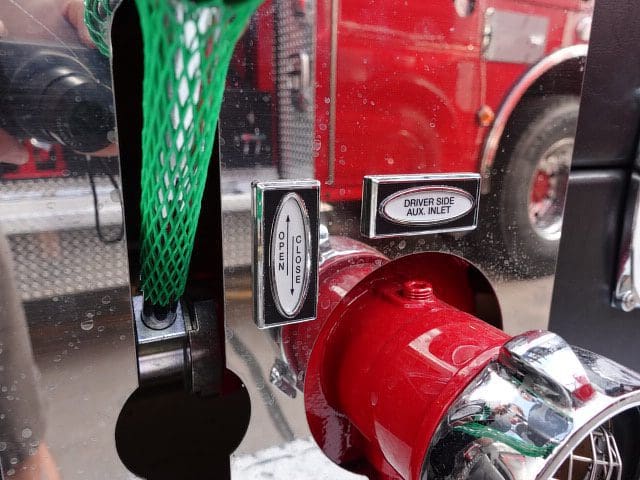

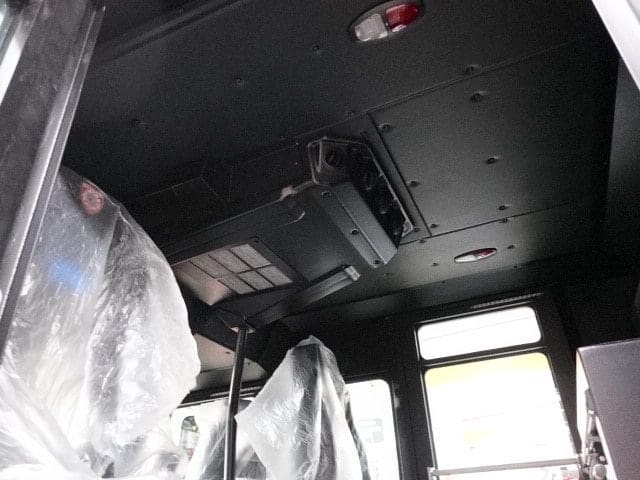

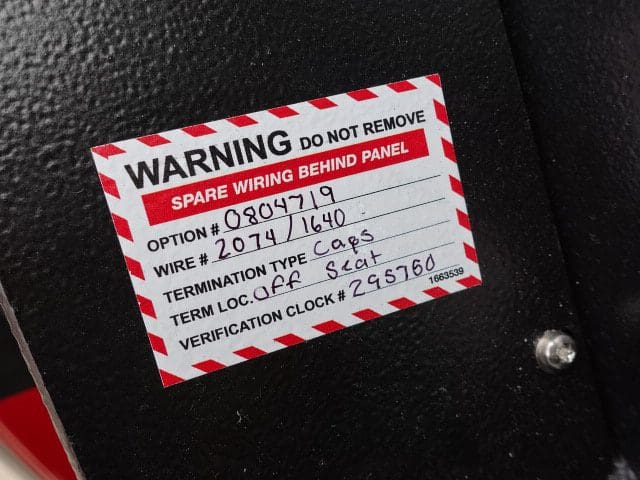

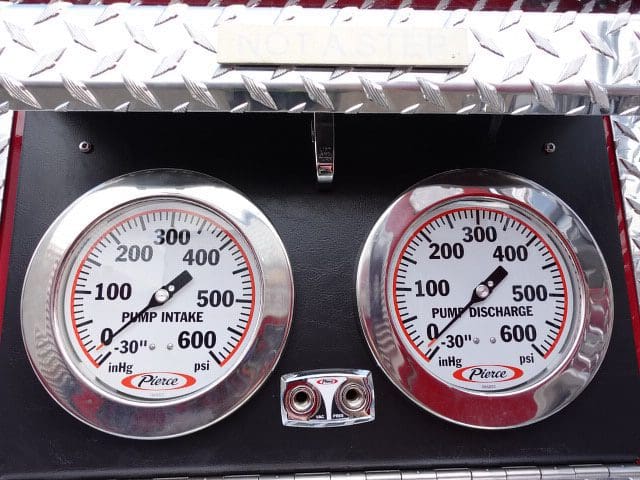

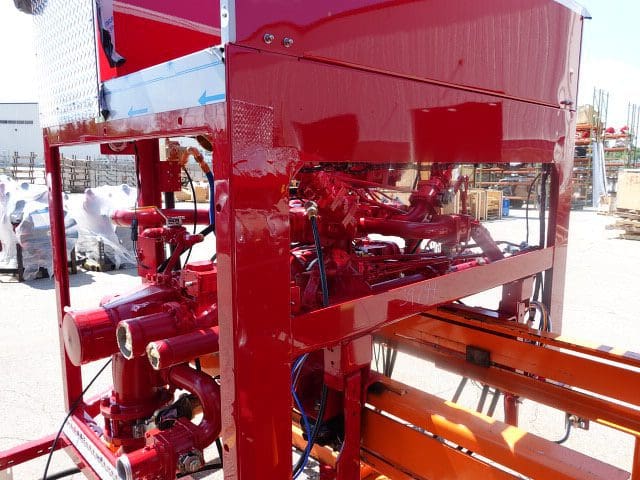

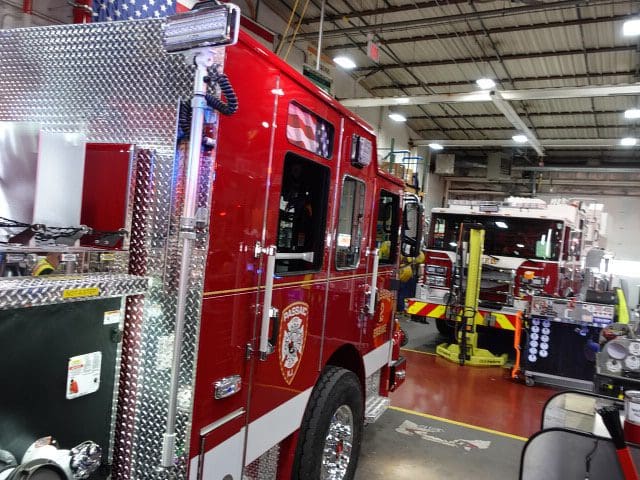

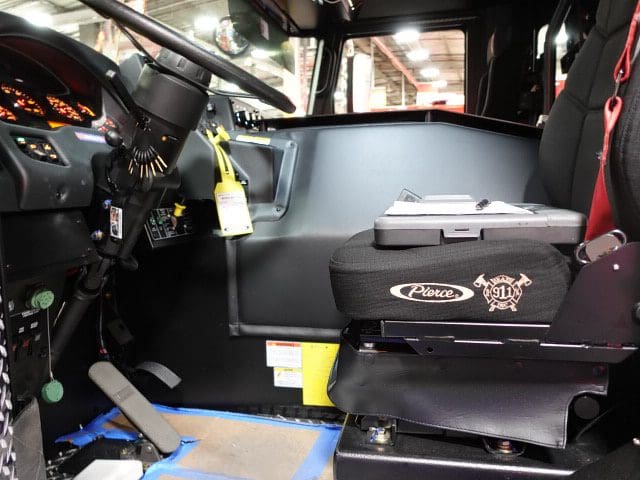

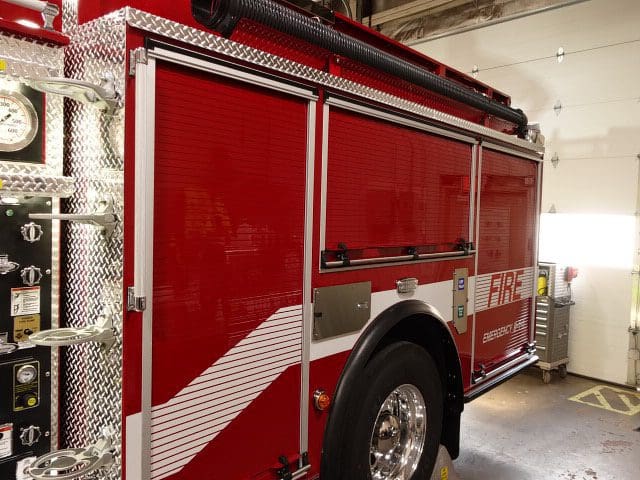

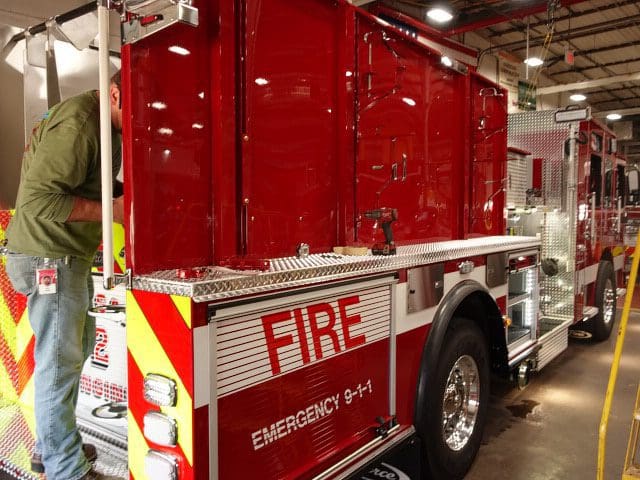

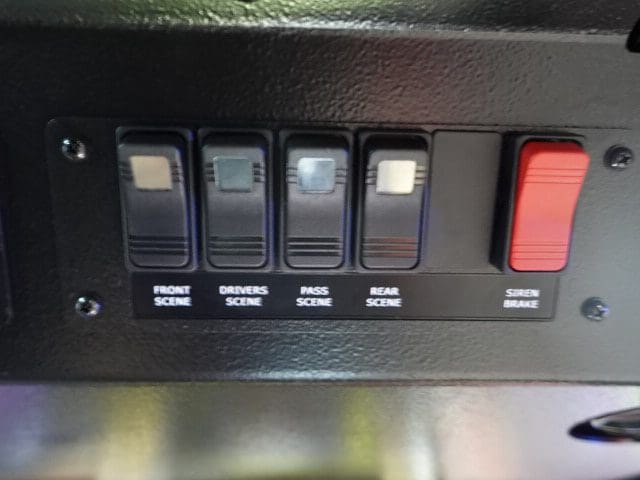

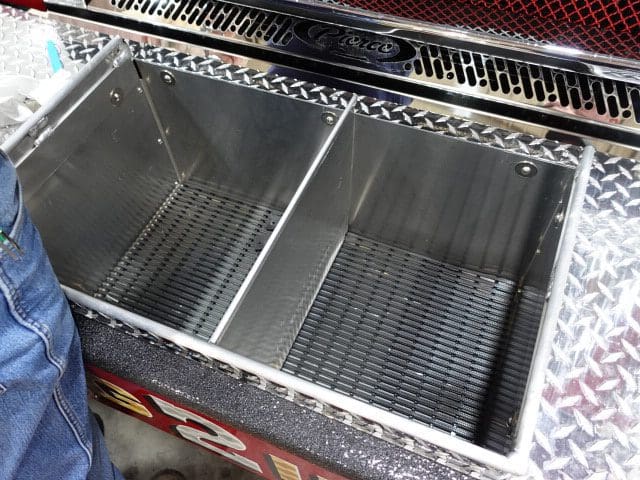

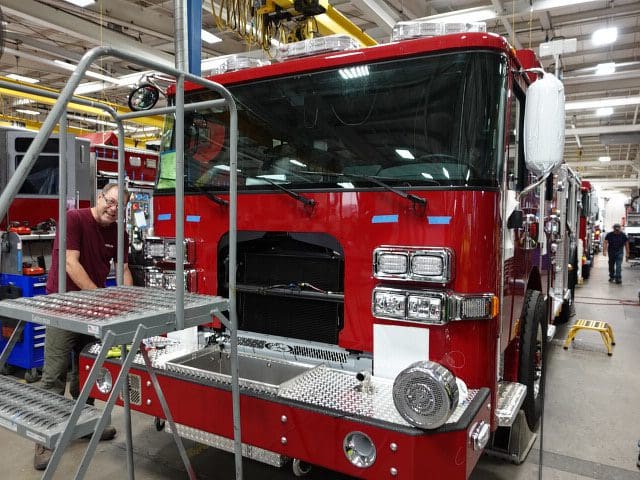

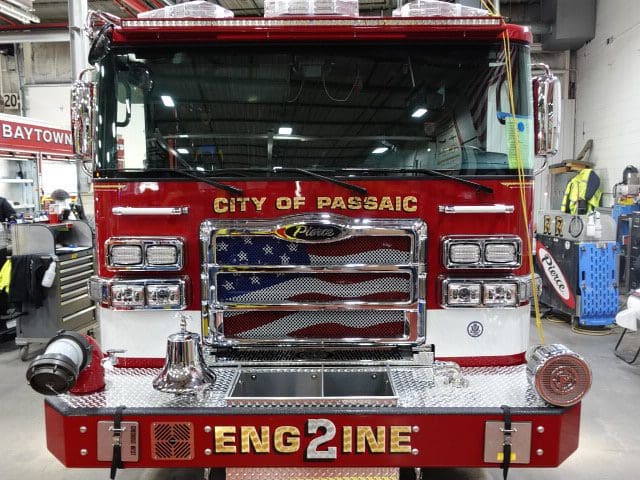

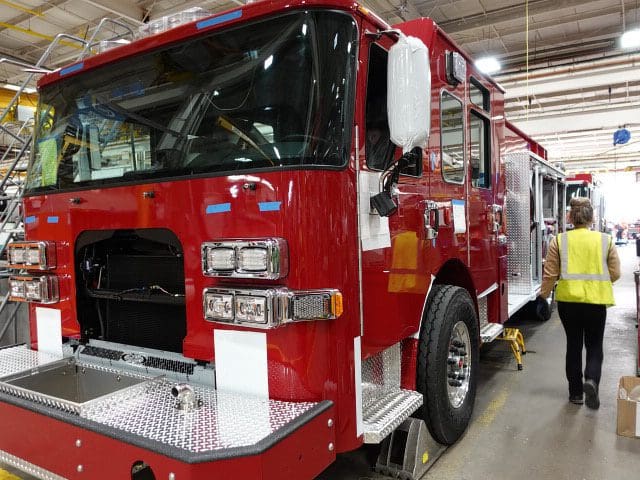

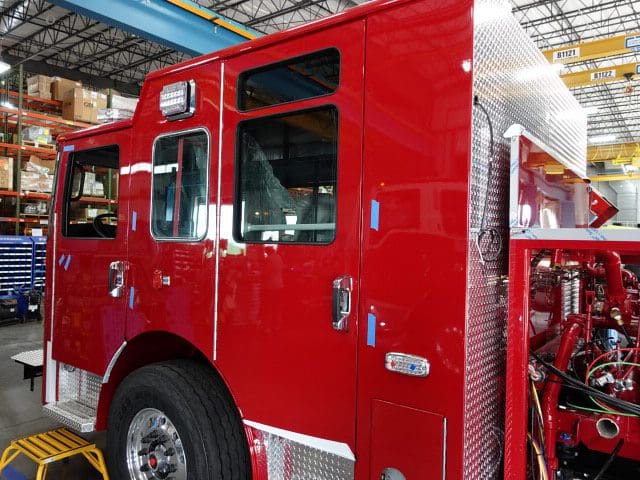

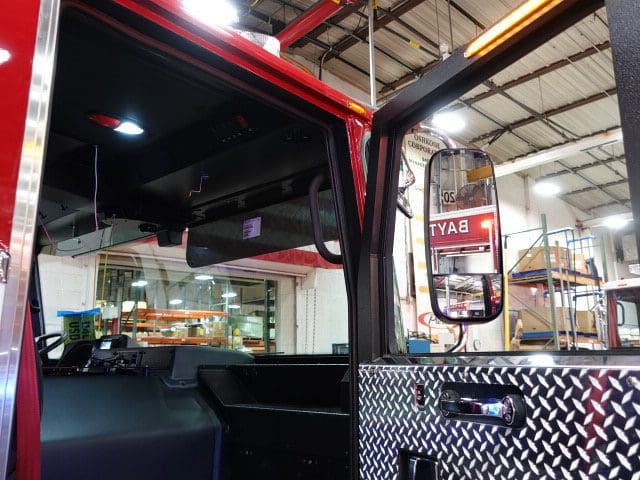

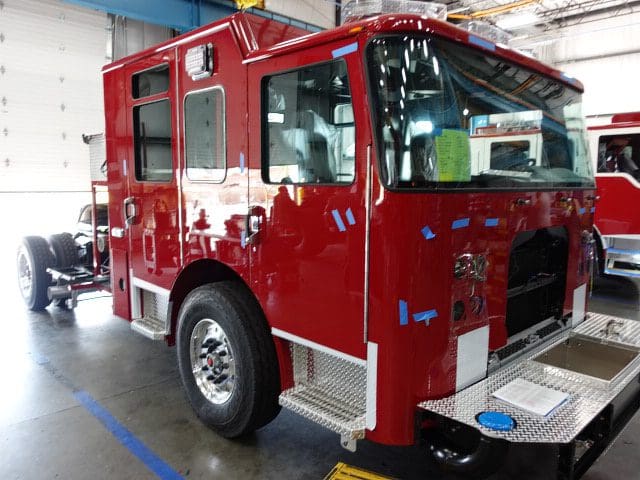

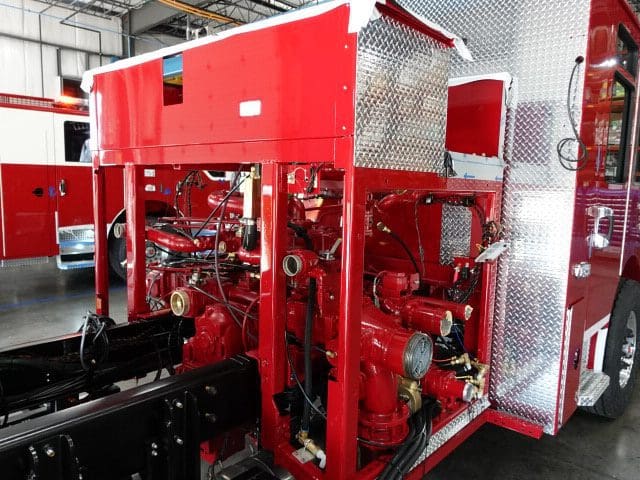

In this report the apparatus completed testing and was released

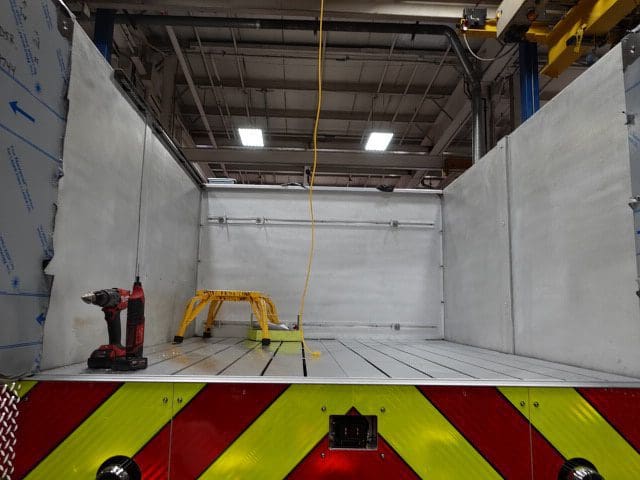

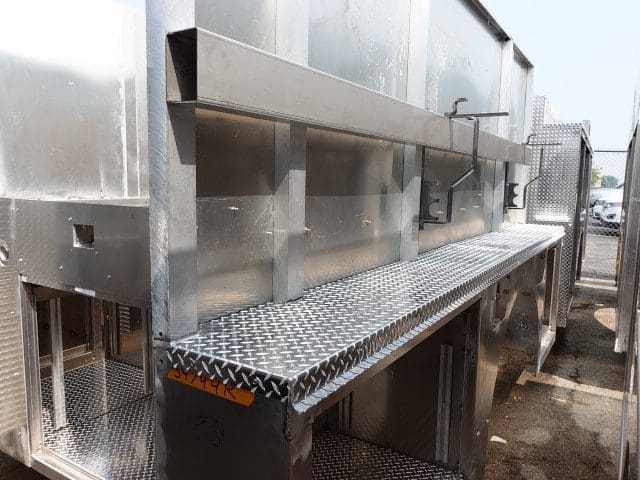

to quality and graphics where any remaining content will be

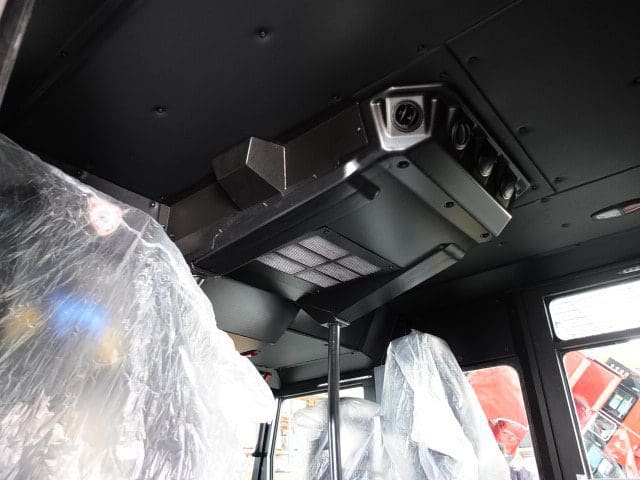

applied. Once finished, it will be made ready for final

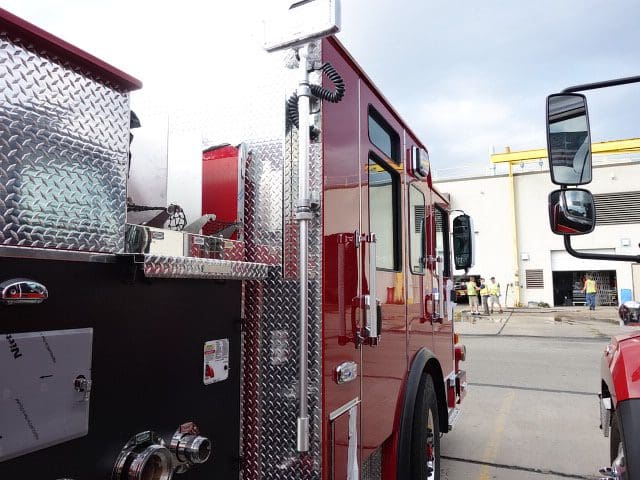

inspection. This is the last scheduled report.

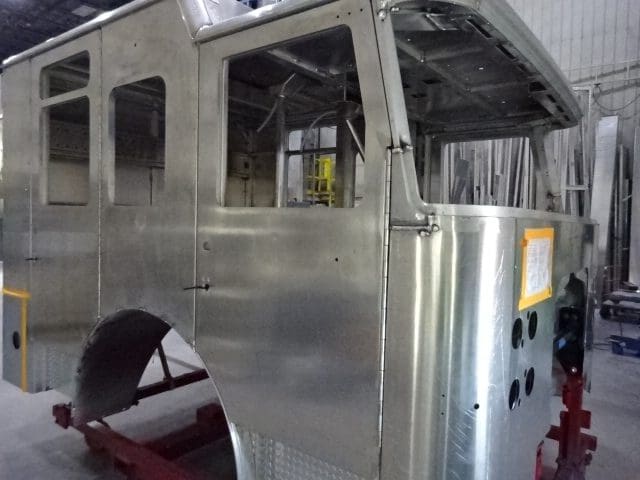

09-22-23

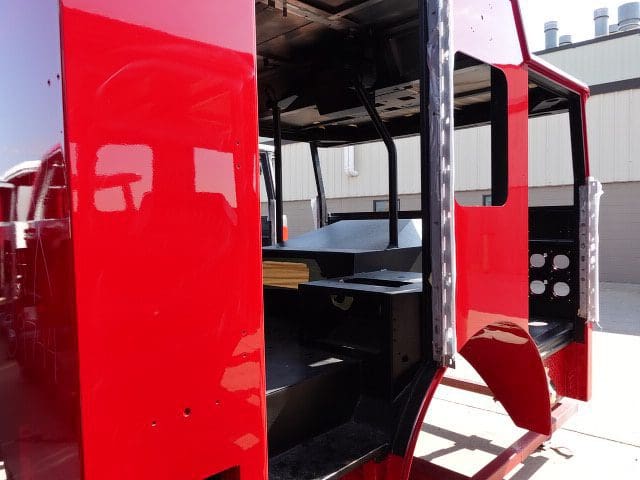

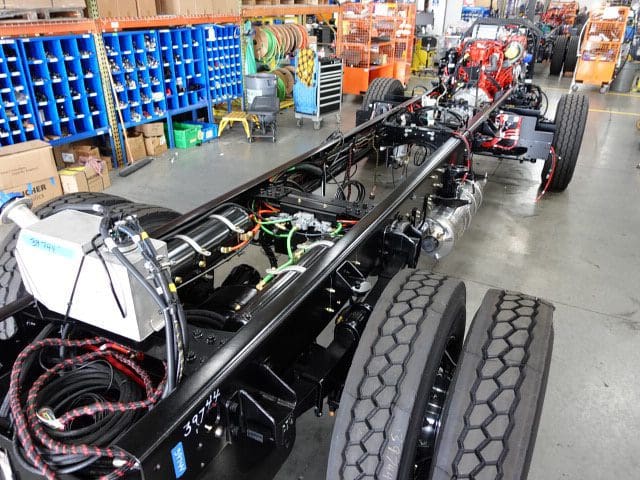

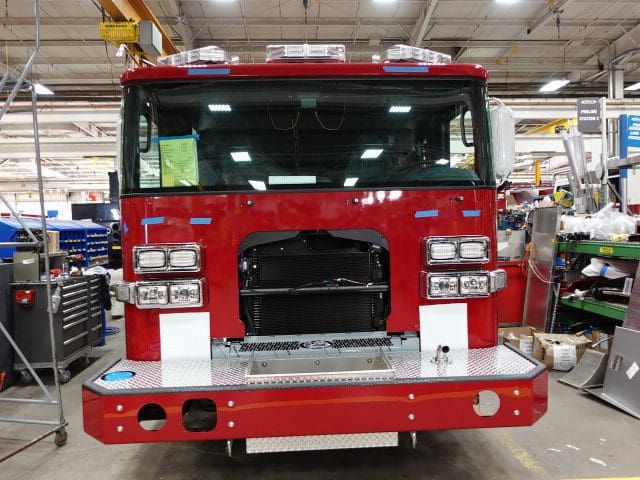

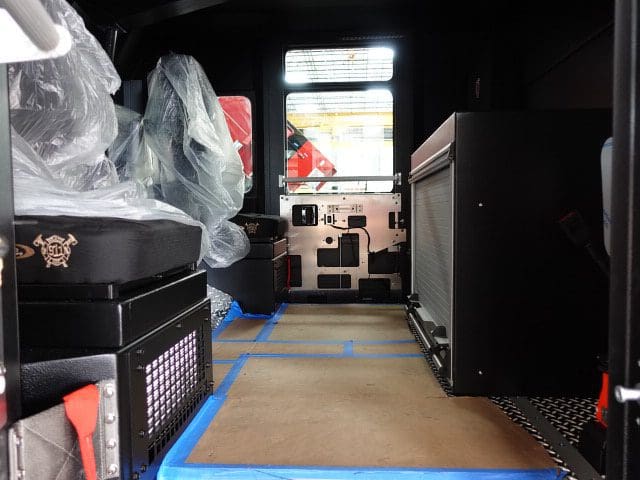

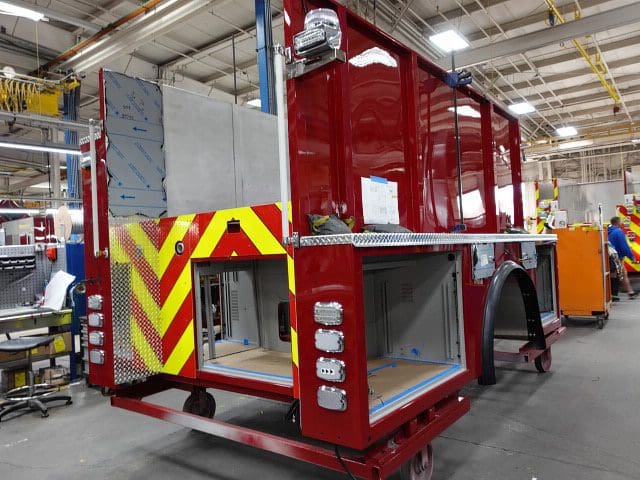

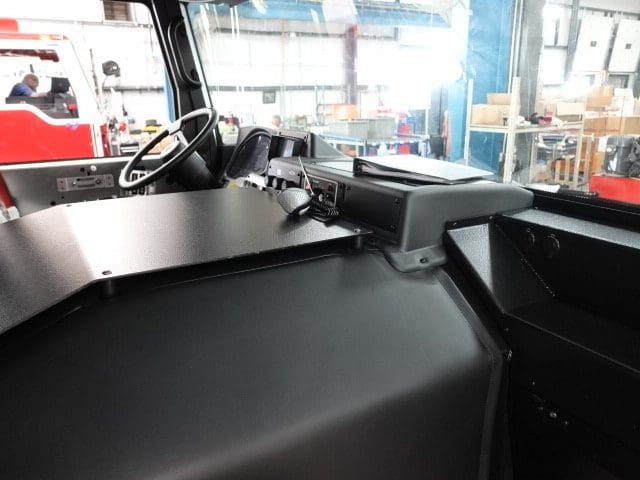

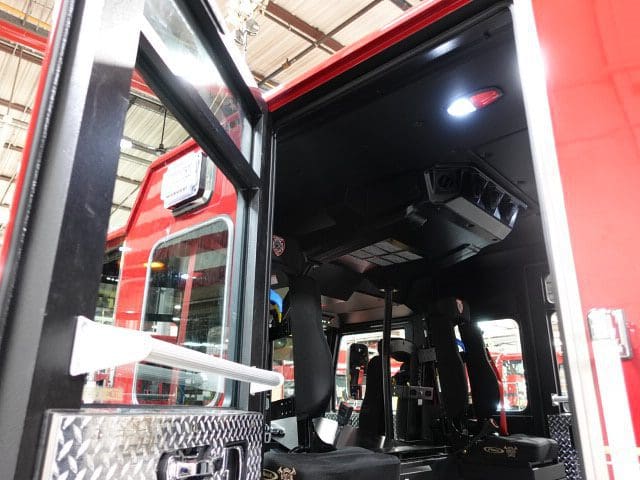

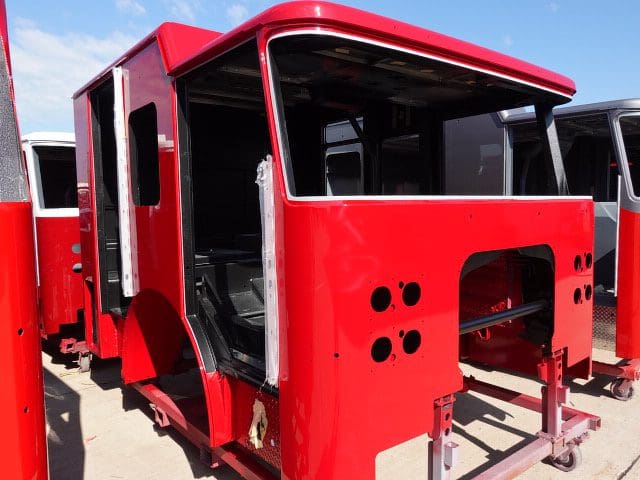

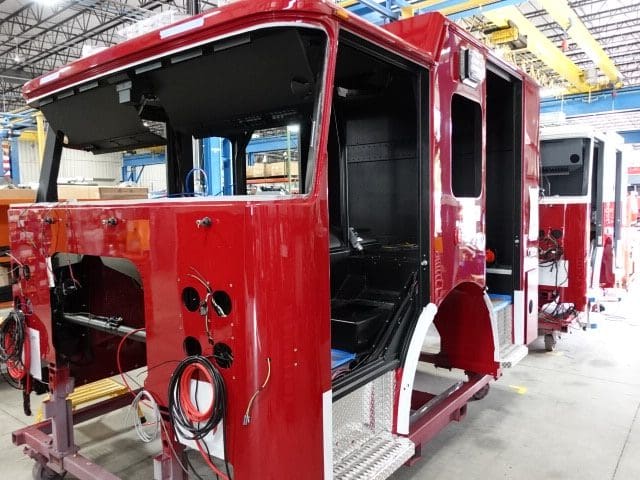

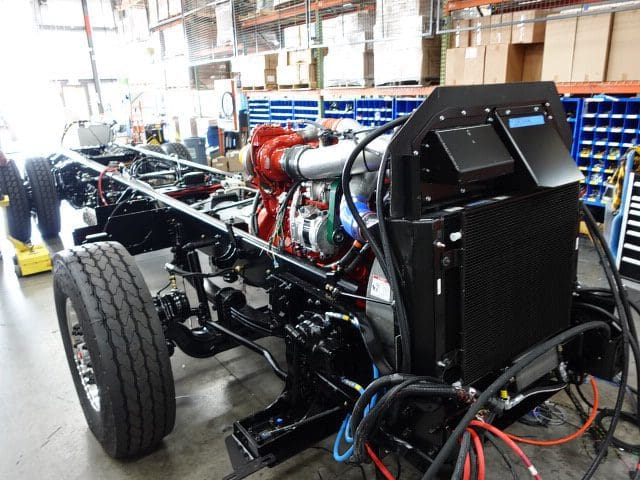

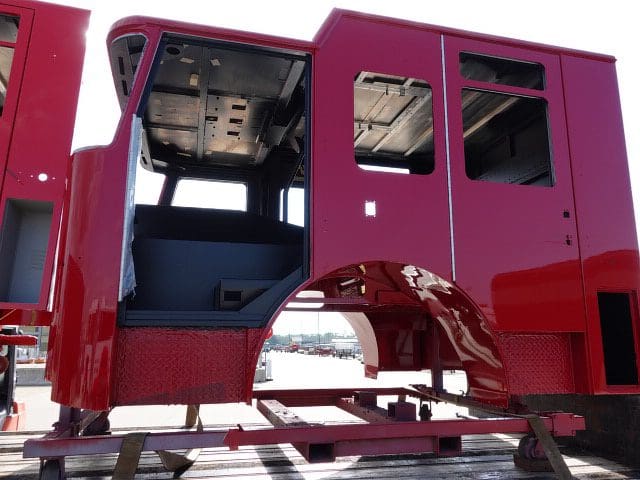

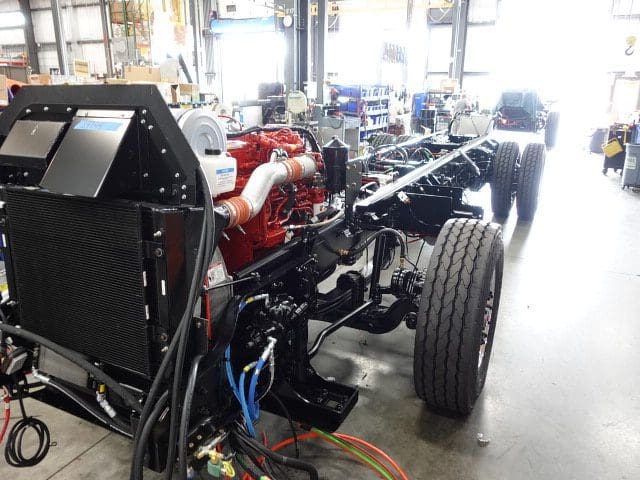

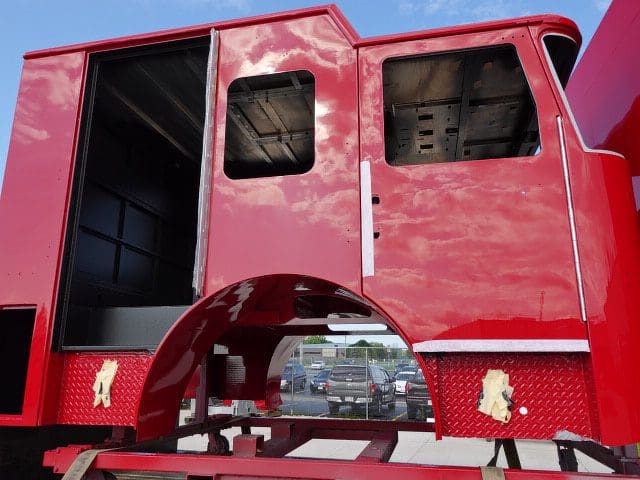

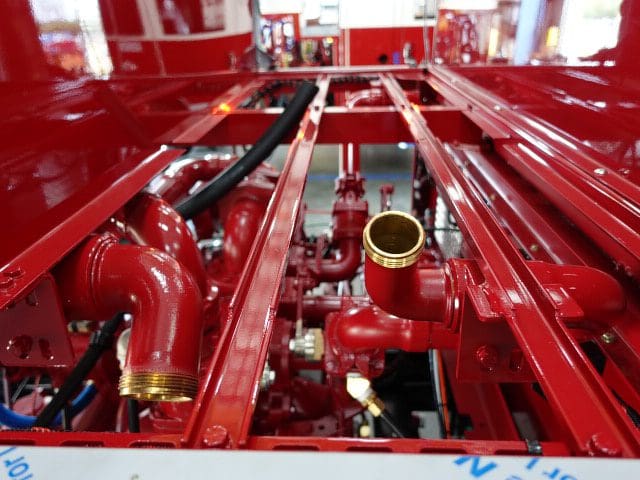

In this report the body was merged with the chassis while initial assembly continued.
09-15-23

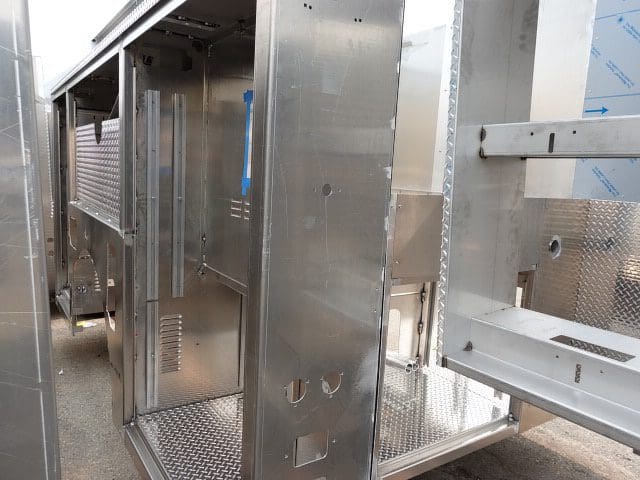

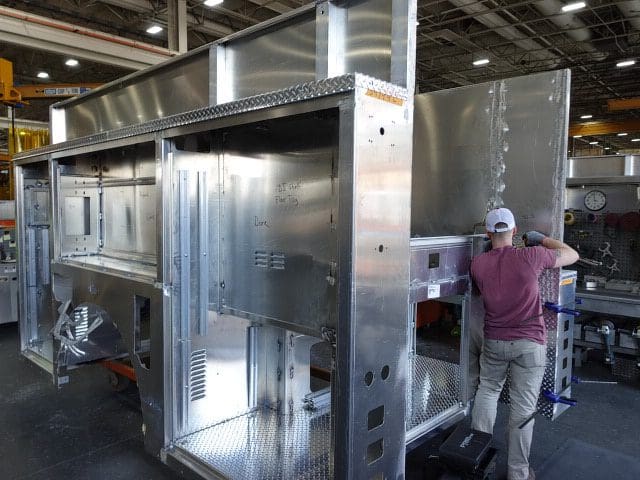

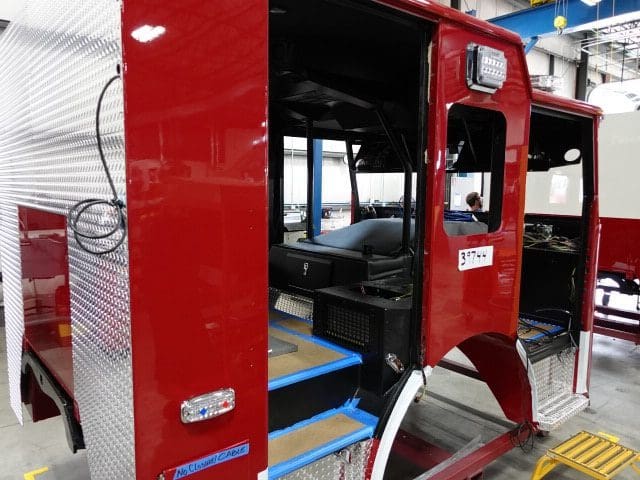

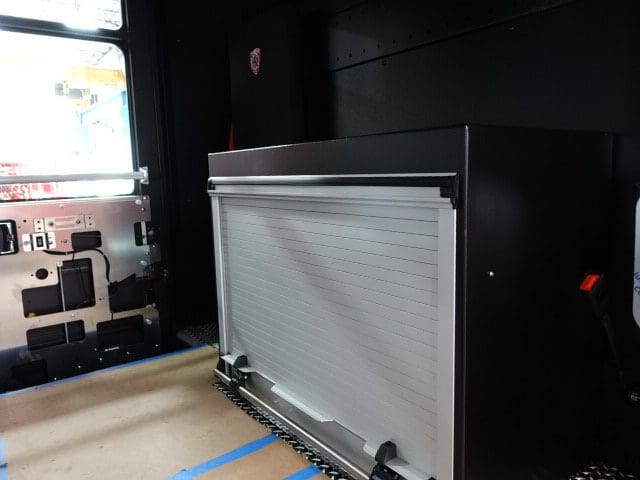

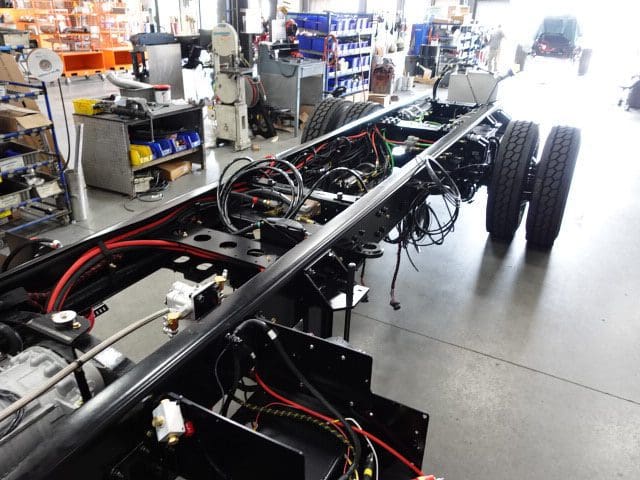

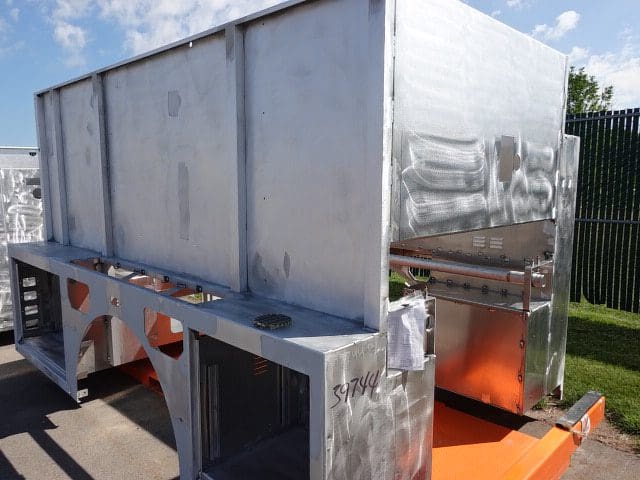

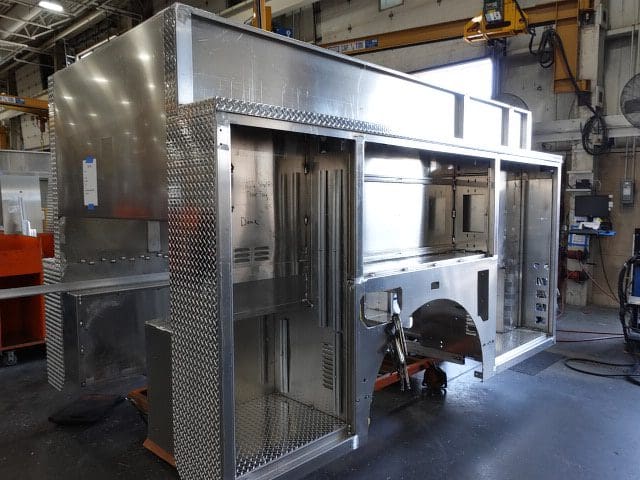

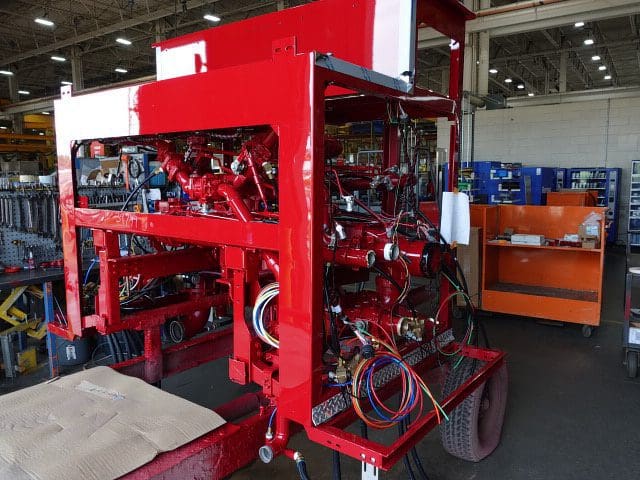

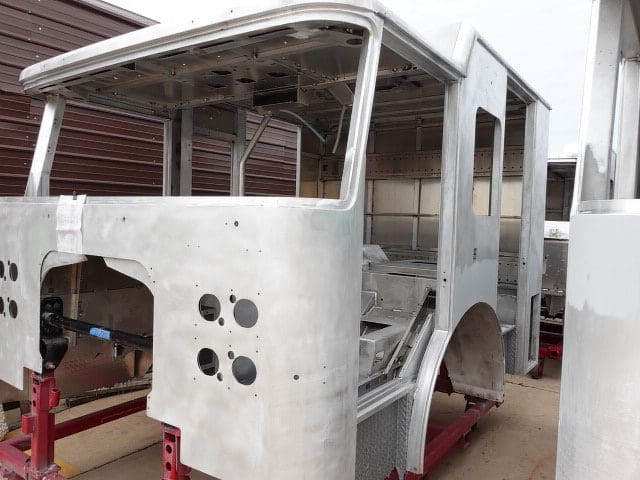

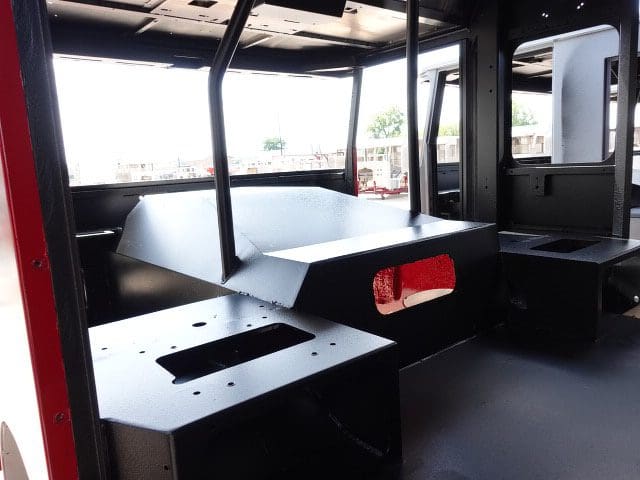

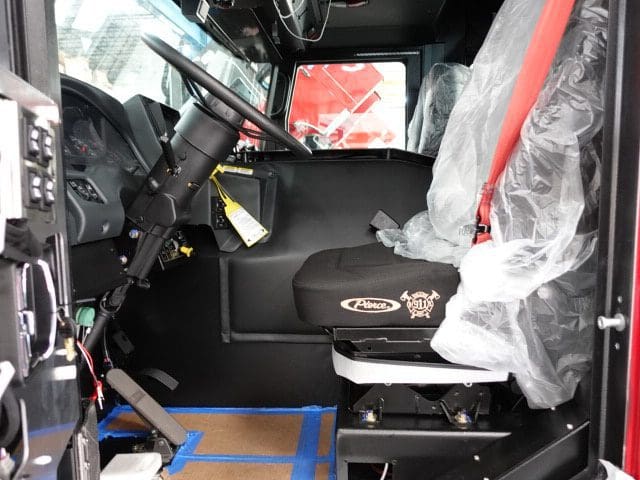

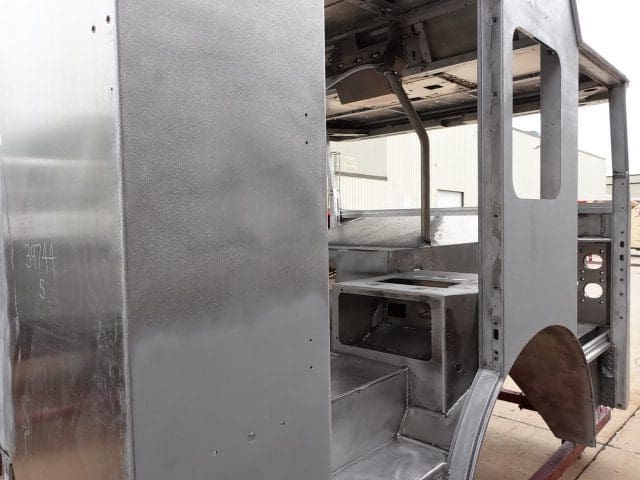

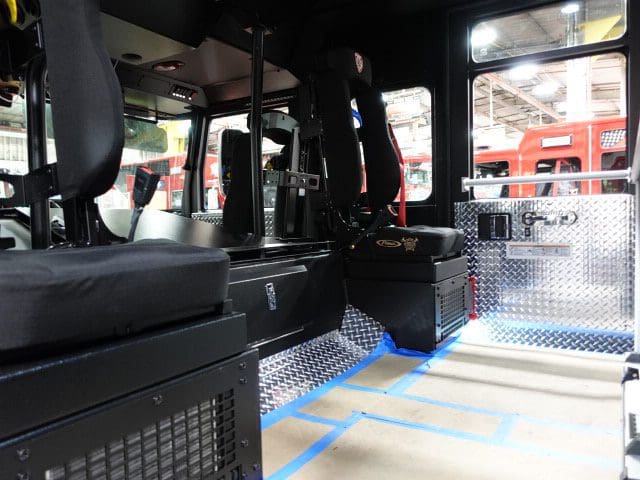

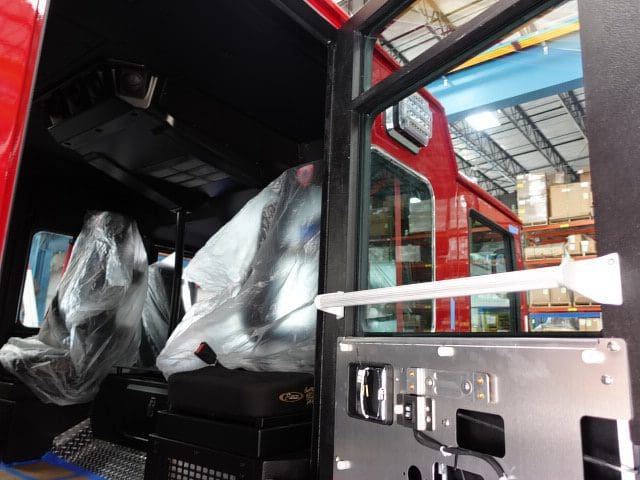

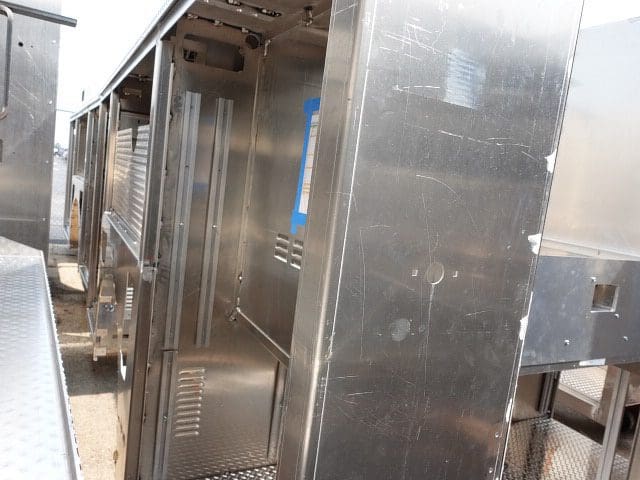

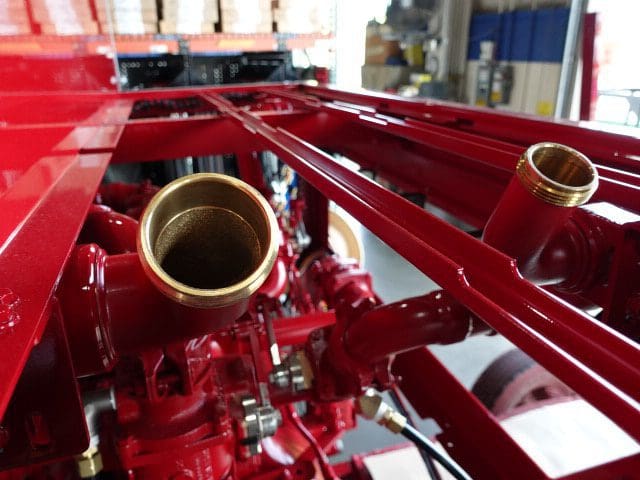

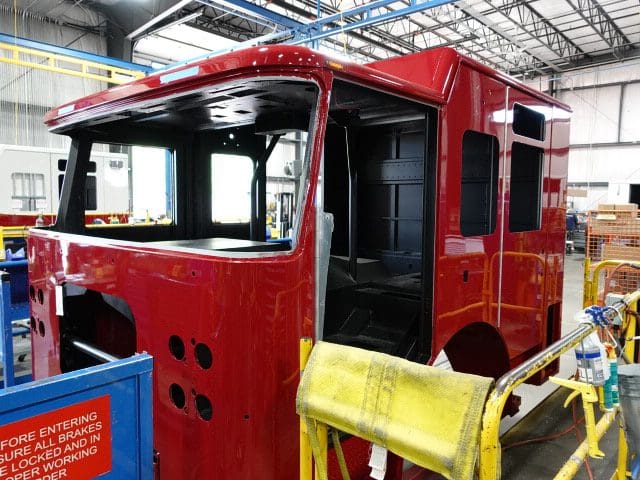

In this report, chassis assembly continued while the body completed initial assembly.

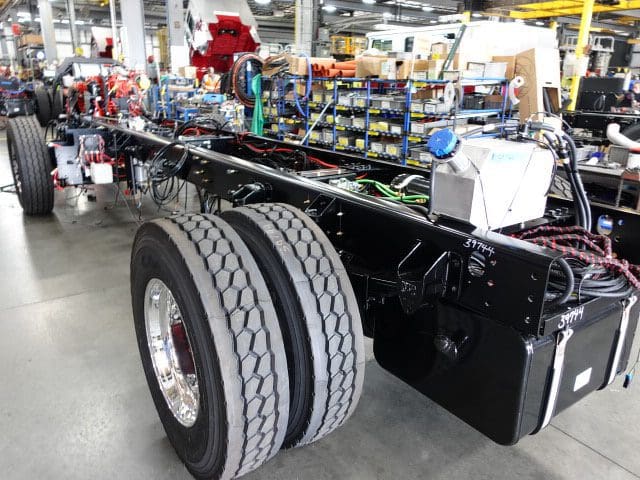

09-08-23

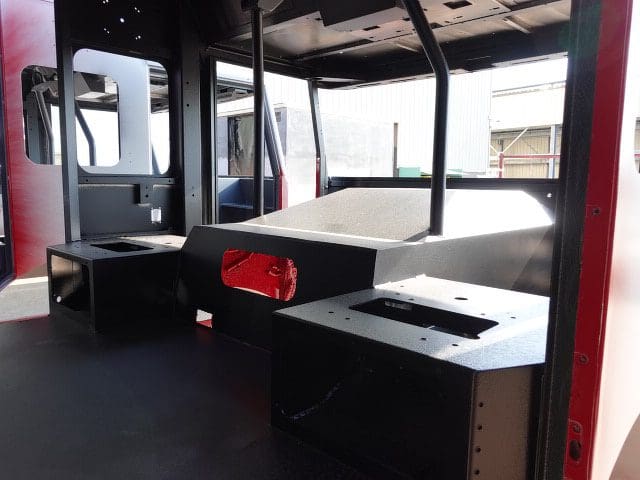

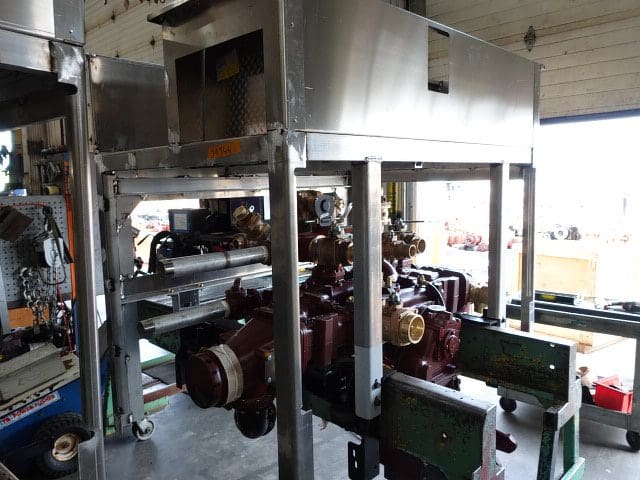

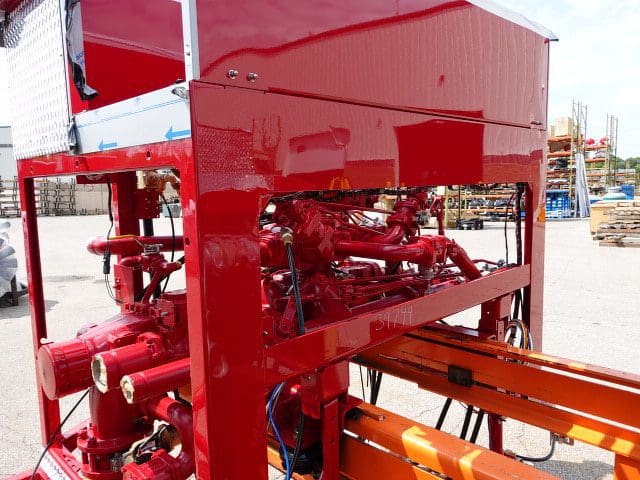

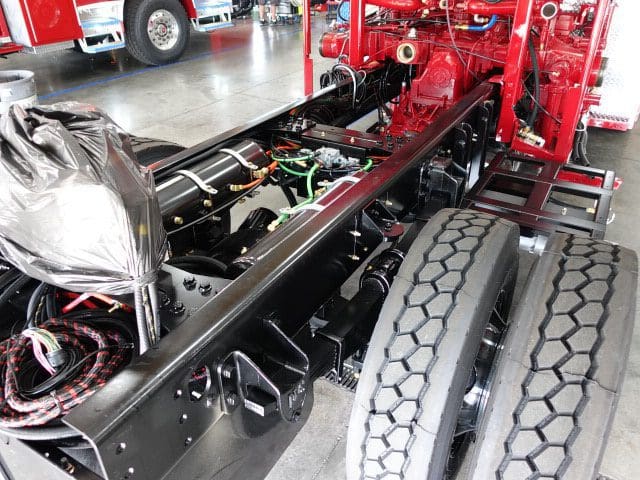

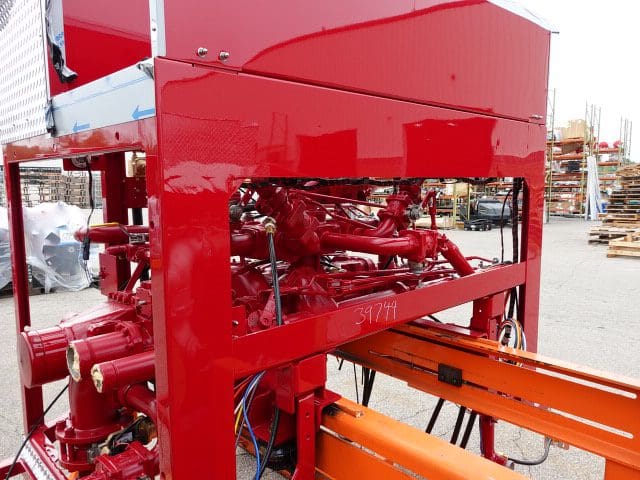

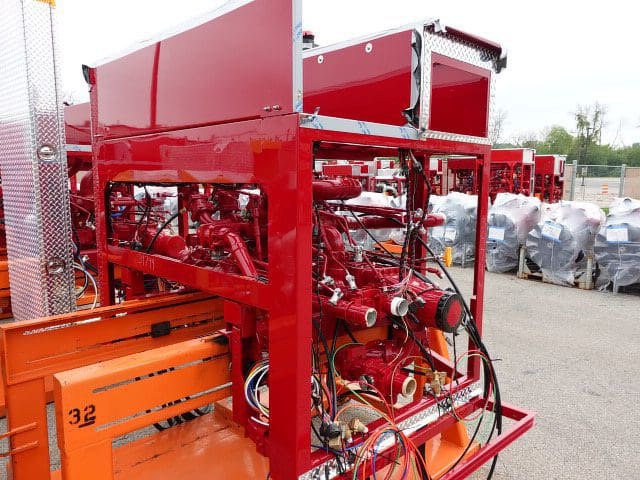

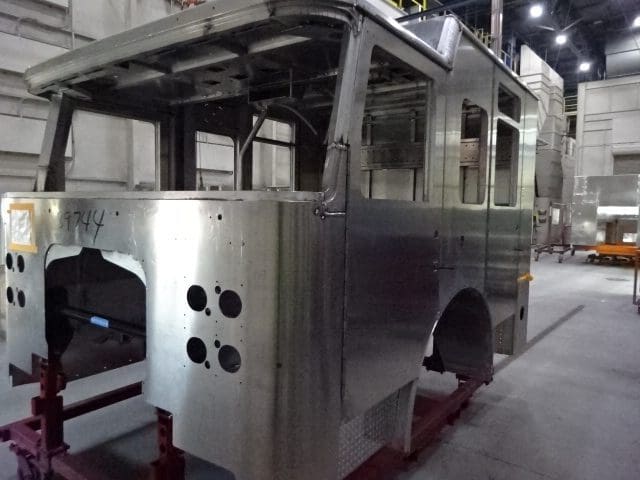

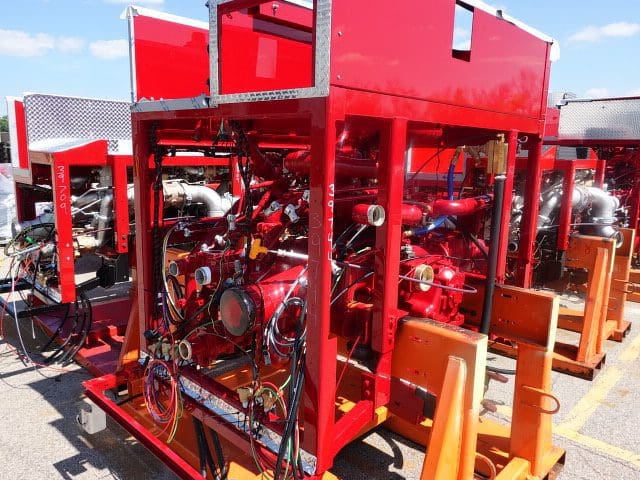

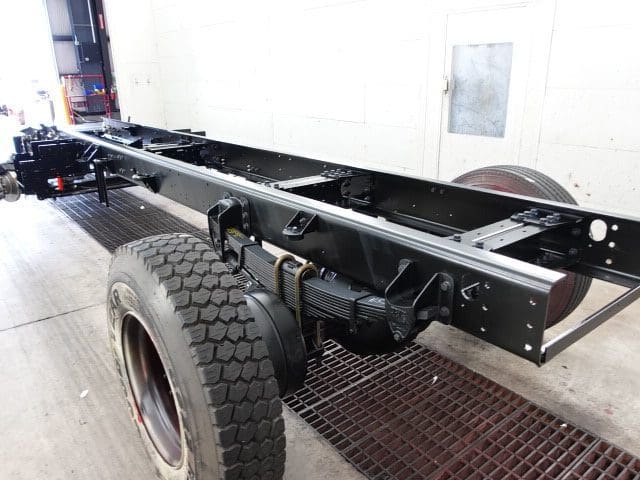

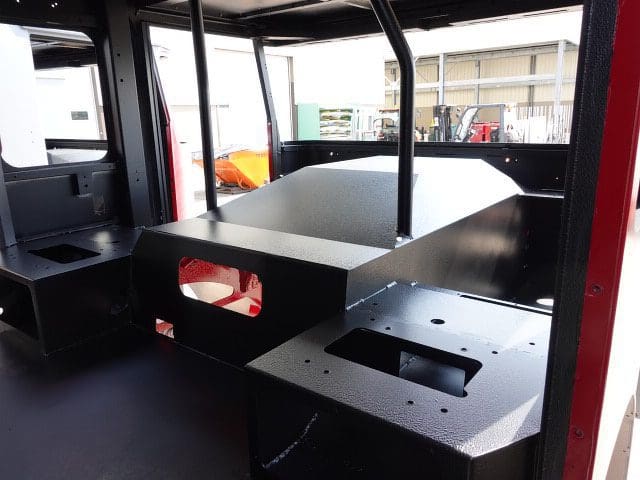

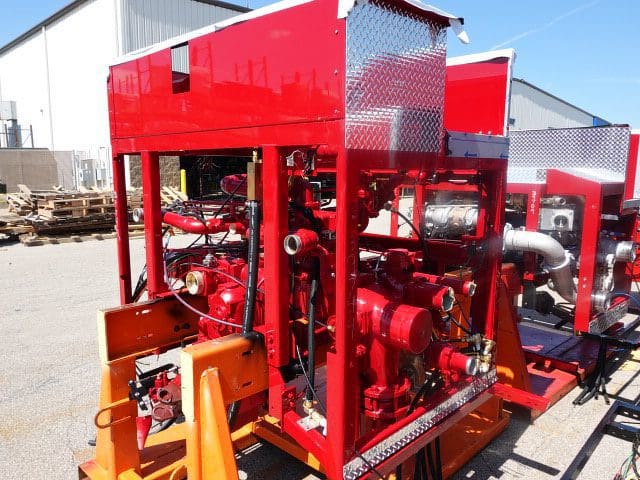

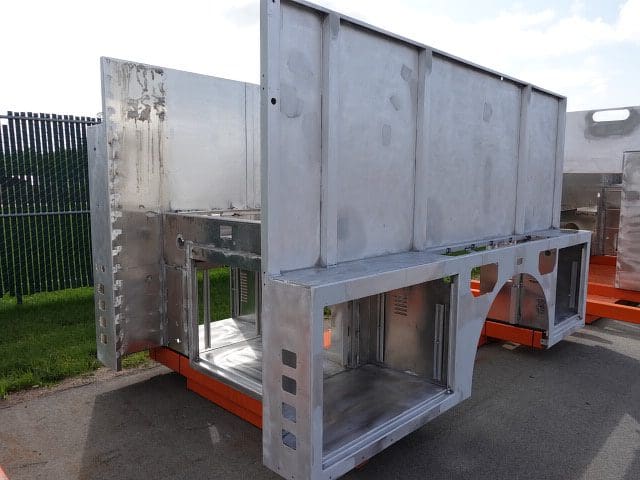

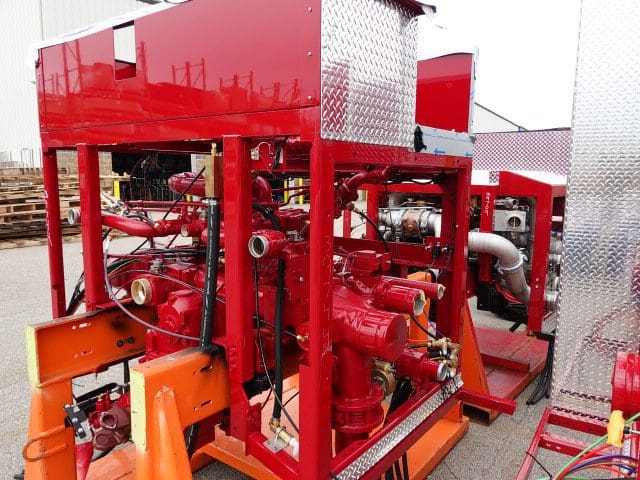

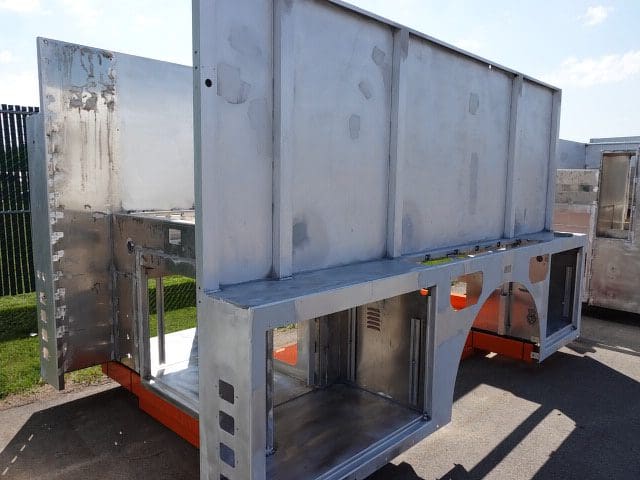

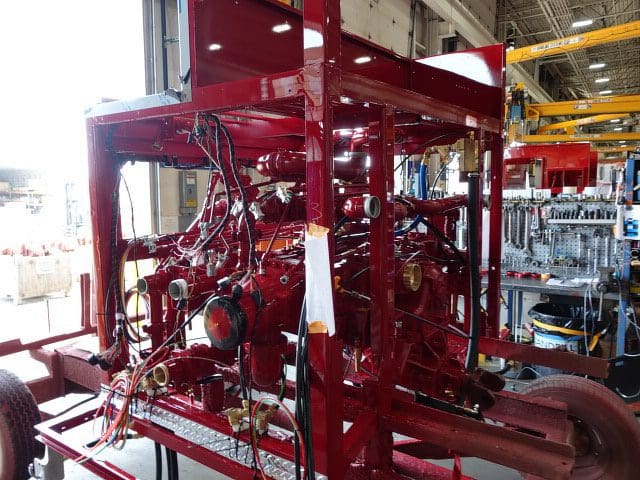

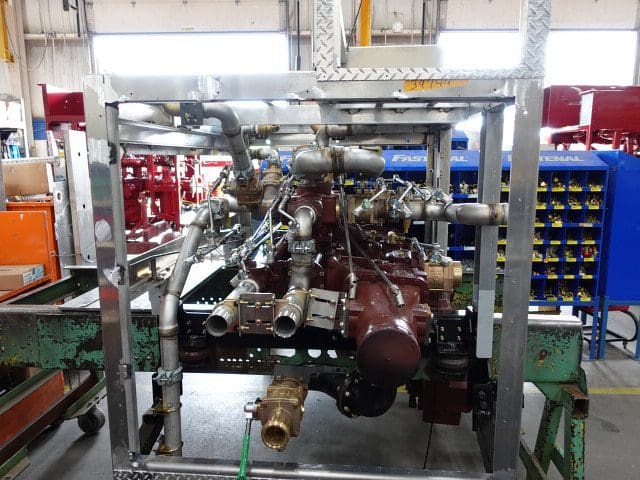

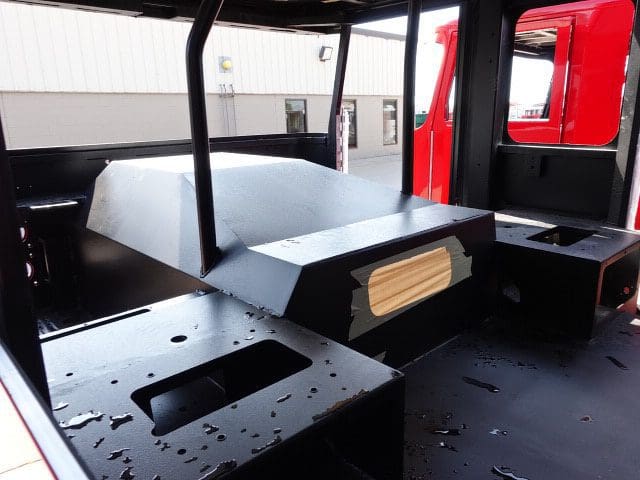

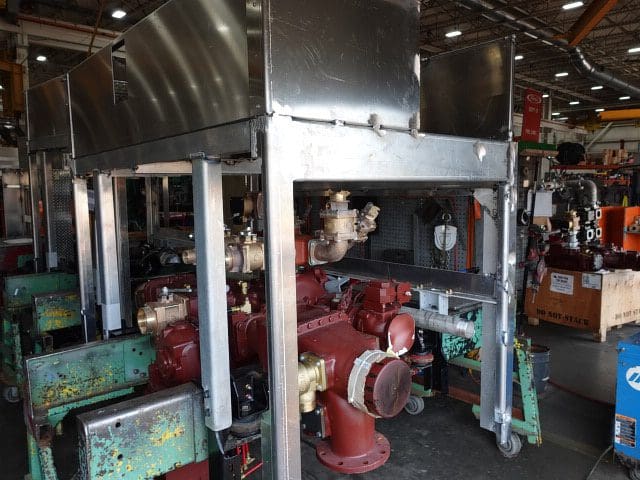

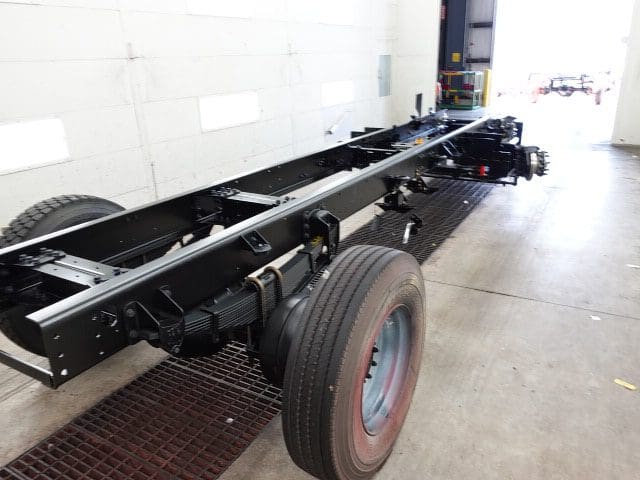

In this report the cab and pump house were installed on the frame while the body began initial assembly.
09-01-23

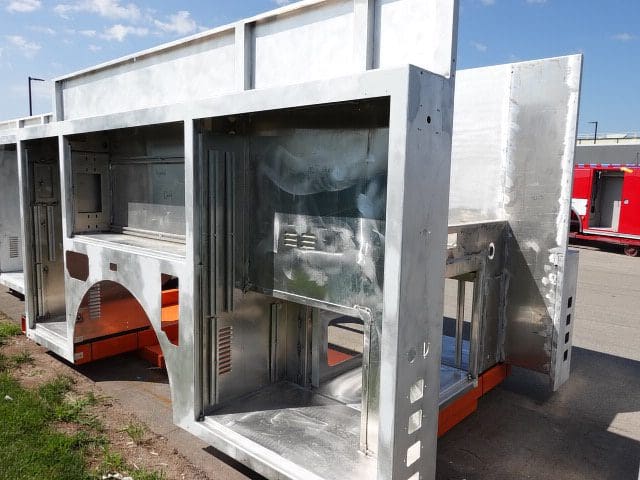

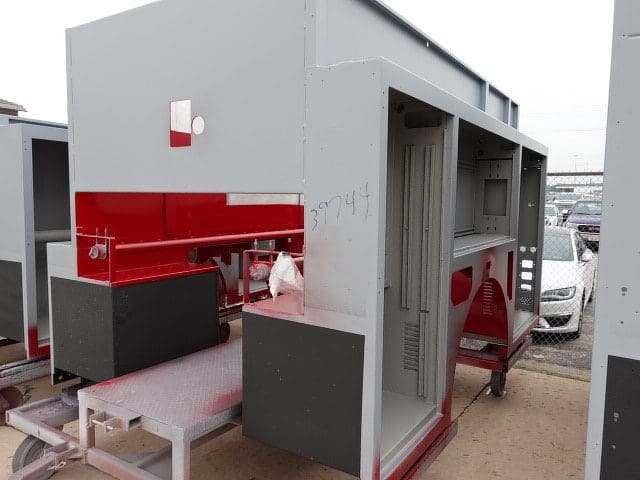

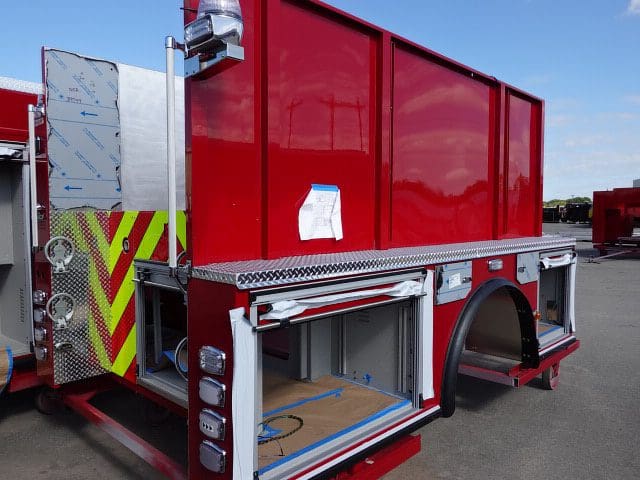

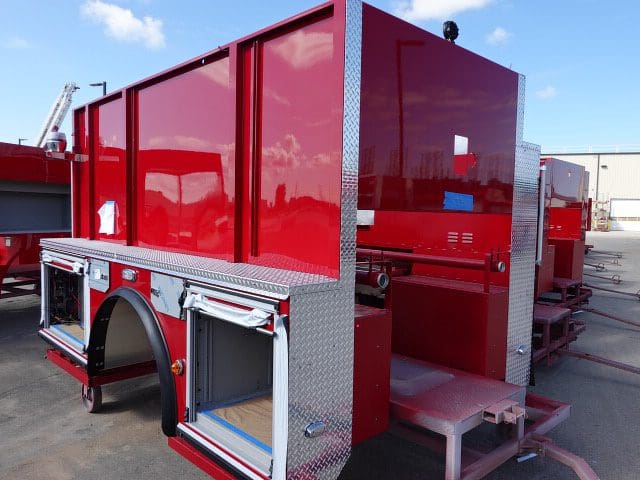

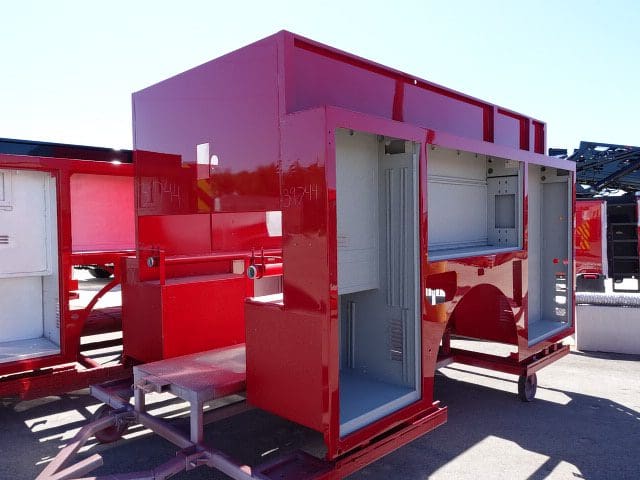

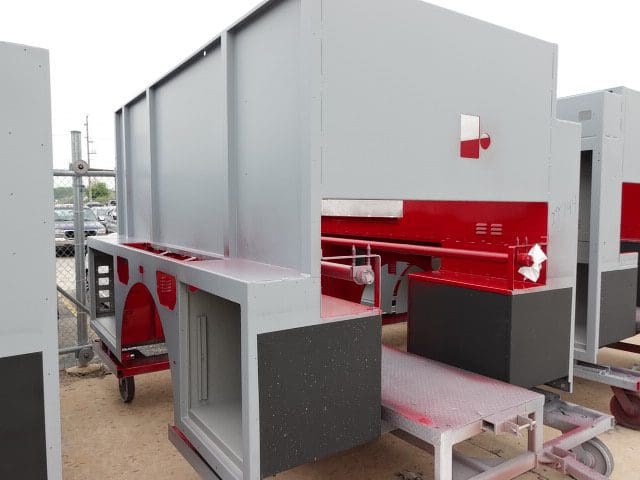

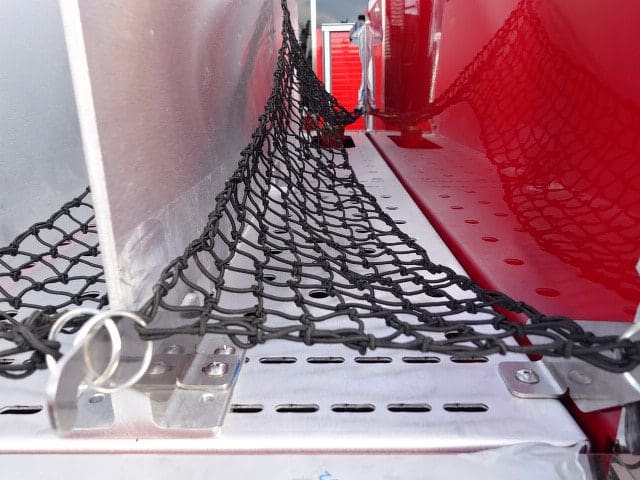

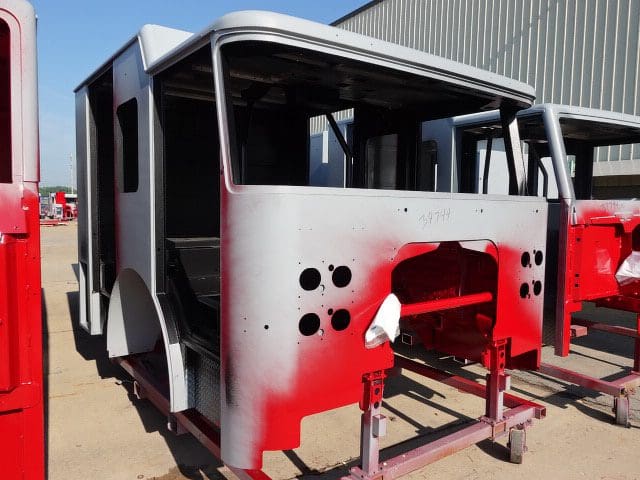

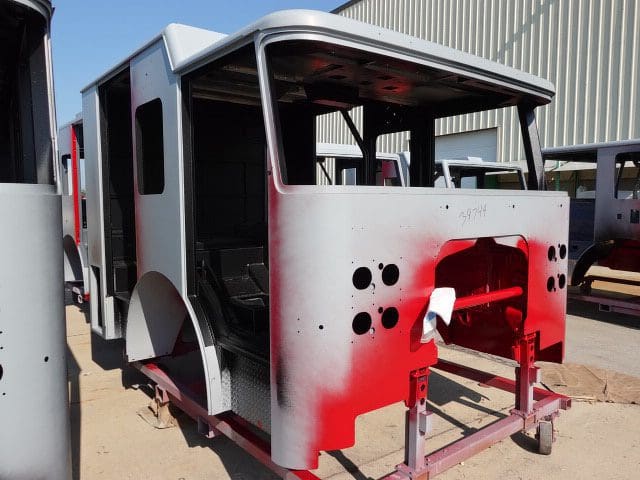

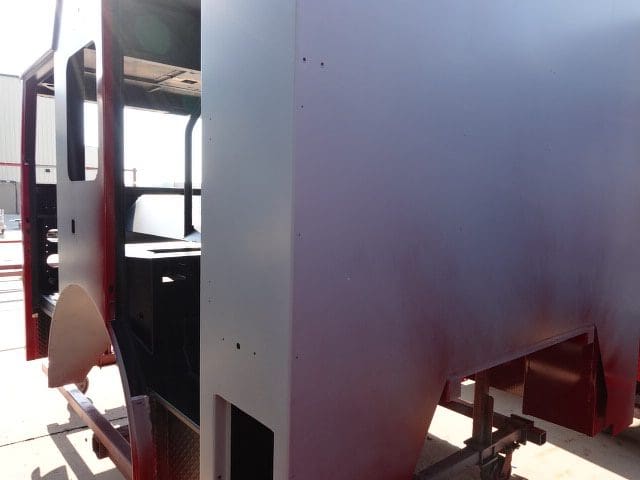

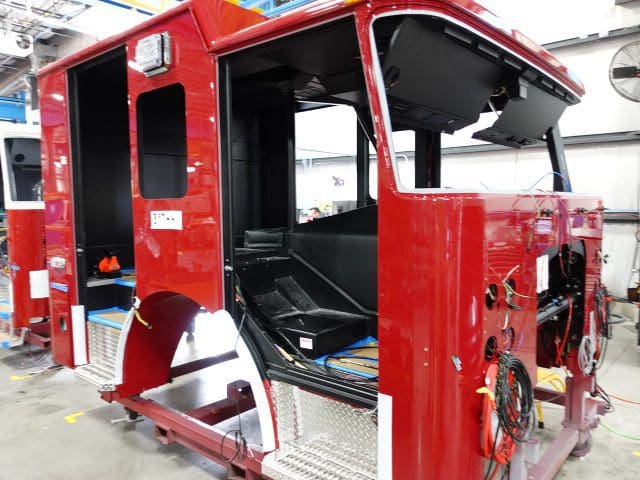

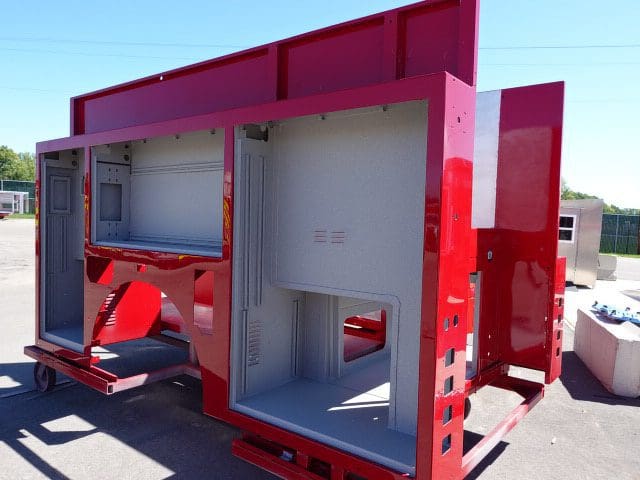

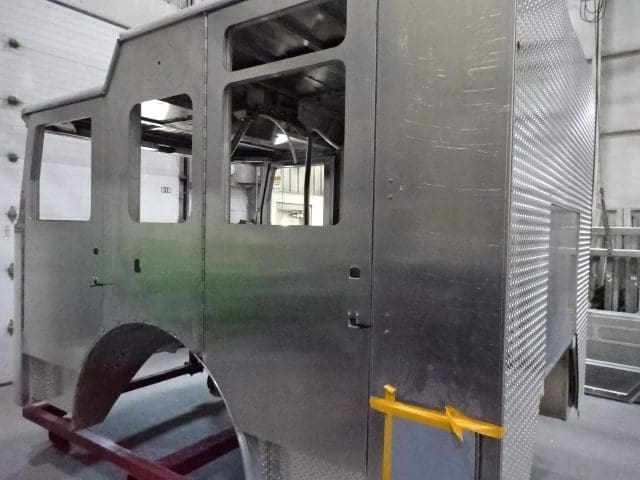

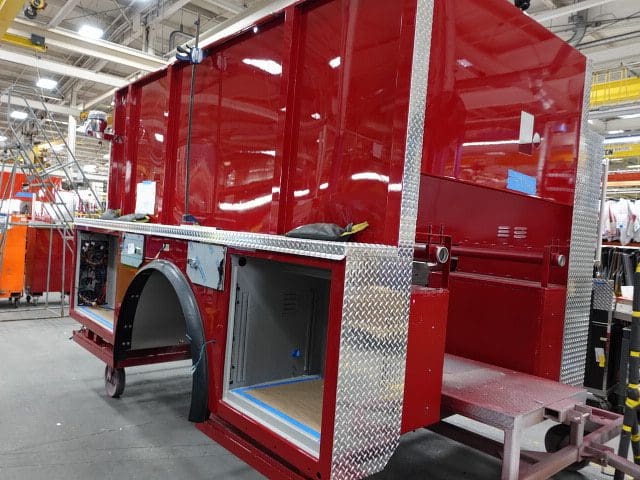

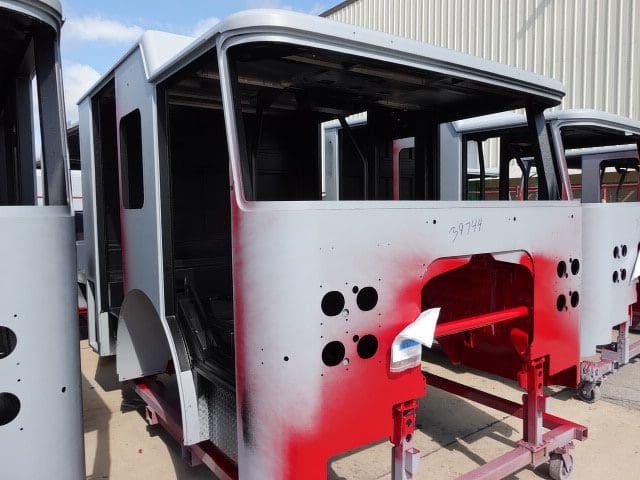

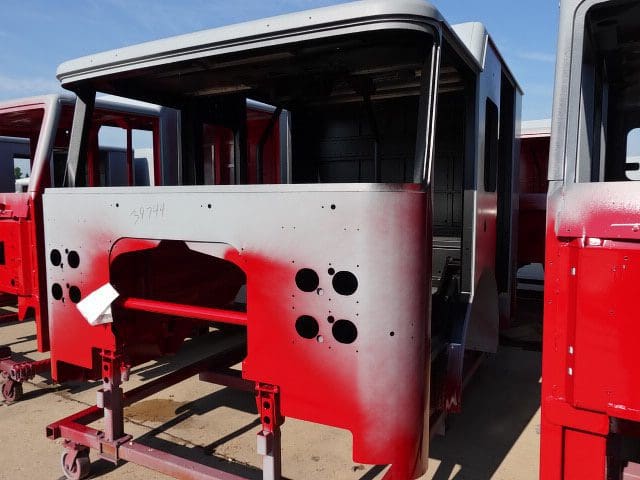

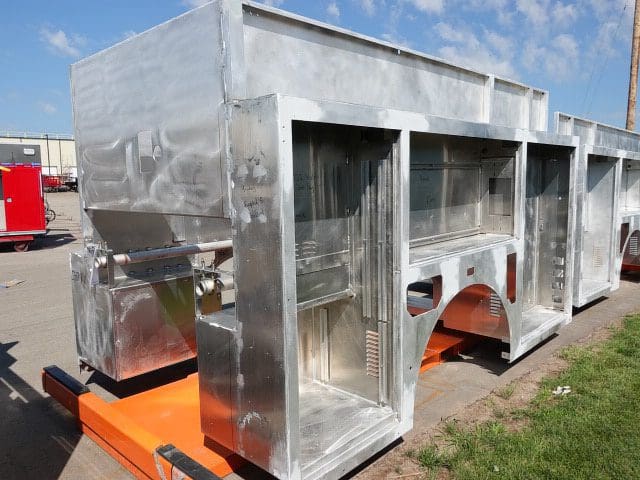

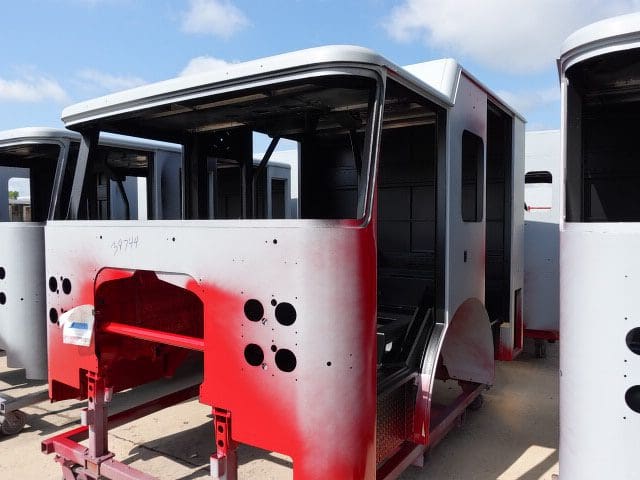

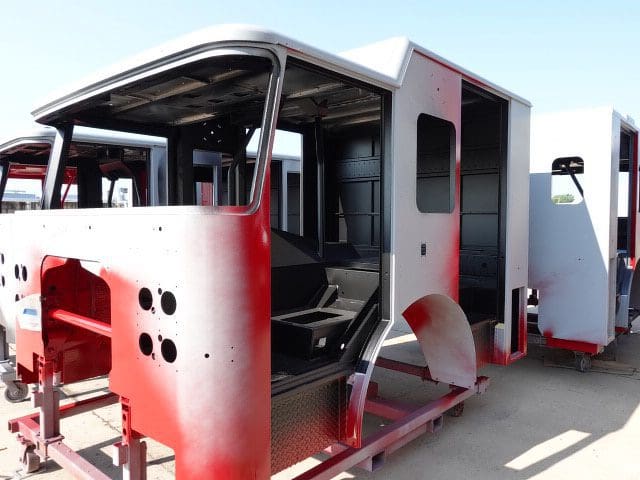

This week, the cab continued initial assembly, the frame build continued, the pump house remained staged, and the body completed paint and was staged.

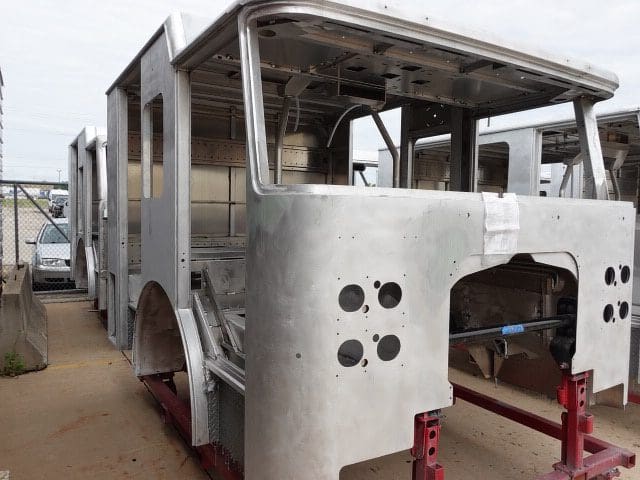

08-25-23

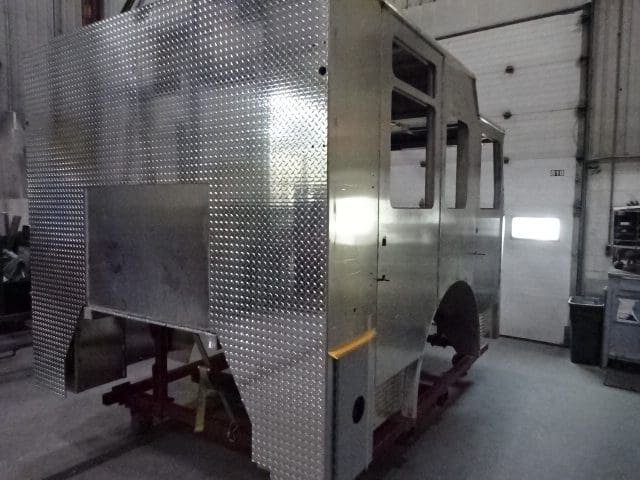

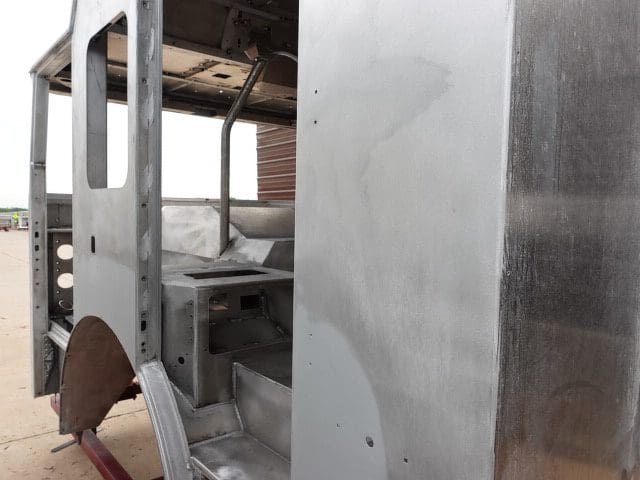

This week, the cab began initial assembly, the frame build began, the pump house was staged, and the body continued the paint process.
08-18-23
This week your cab was staged to begin initial assembly, the pump house completed initial assembly, and the body was staged to continue through paint.
08-11-23

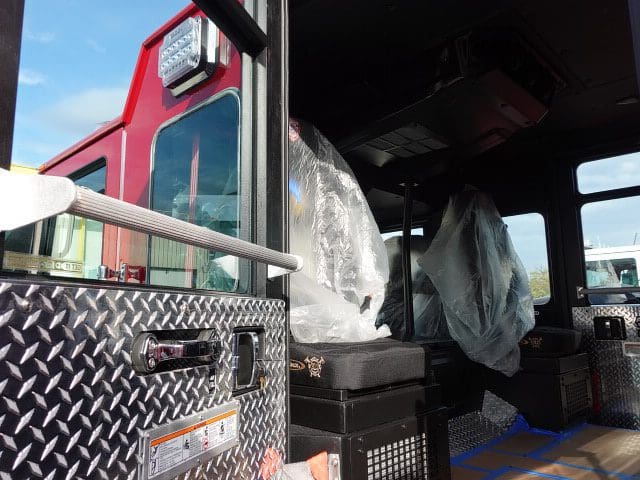

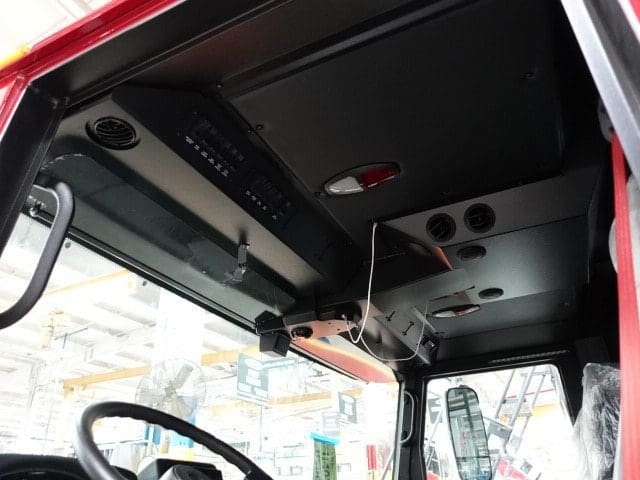

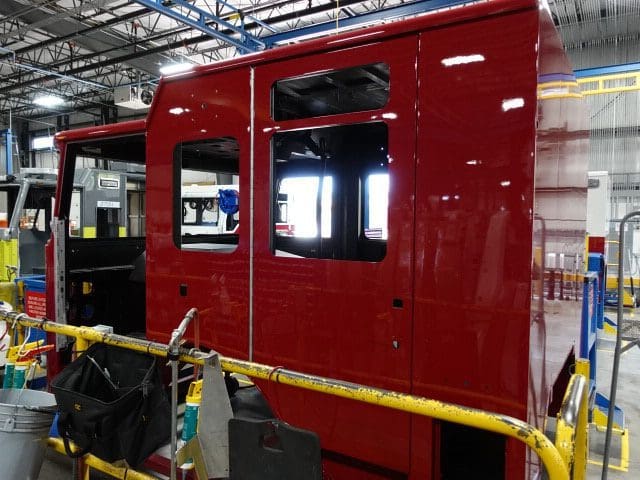

This week your cab completed paint, the pump house continued initial assembly, and the body began the paint process.
08-04-23

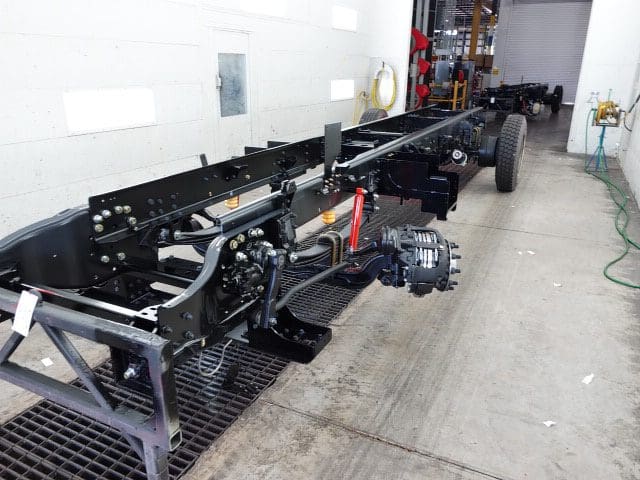

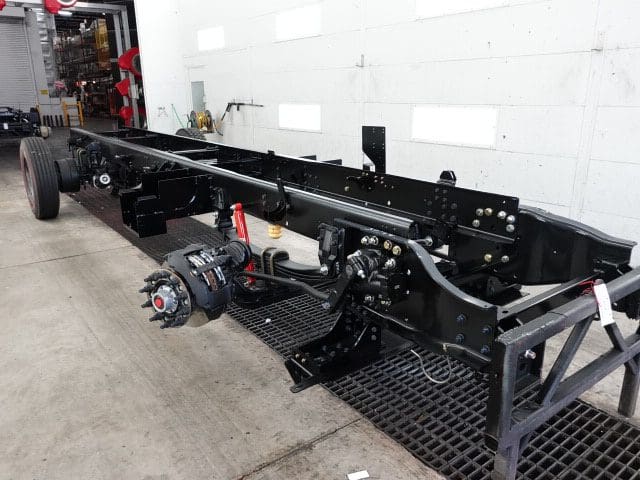

This week, the cab remained staged to continue through paint, the pump house continued initial assembly, and the body remained staged.
07-28-23
This week, the cab was staged to continue through paint, the pump house began initial assembly, and the body completed fabrication and was staged.
