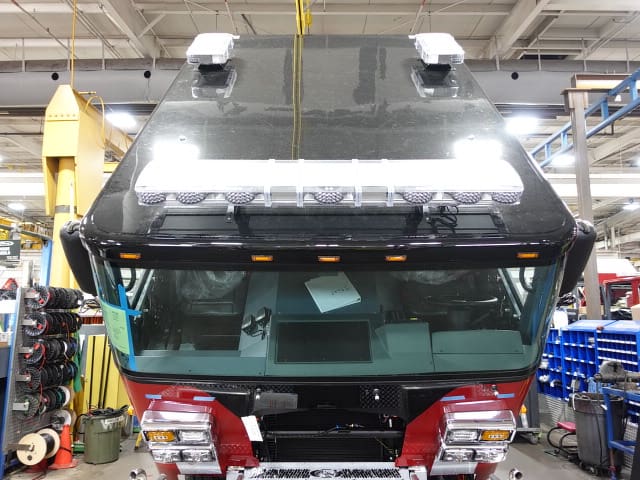

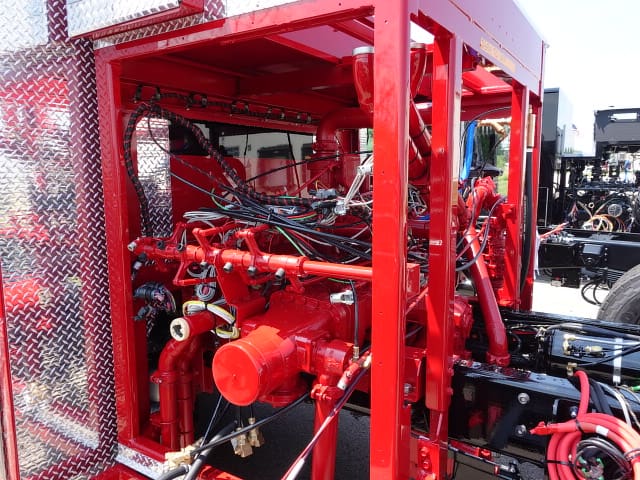

08-15-25

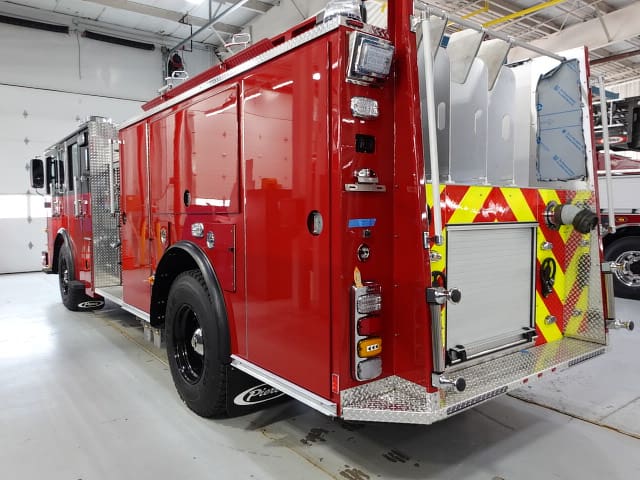

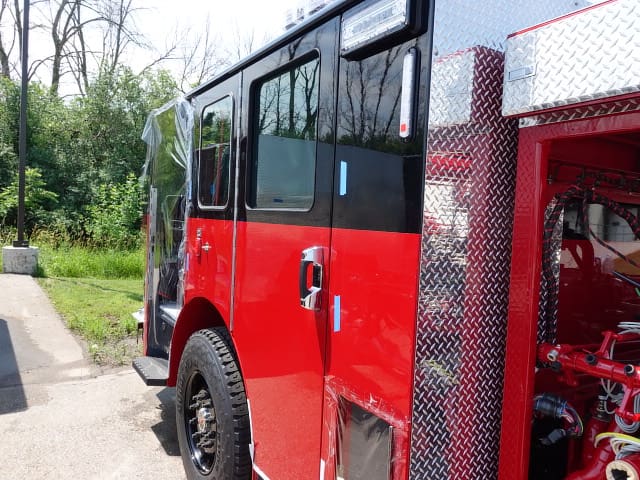

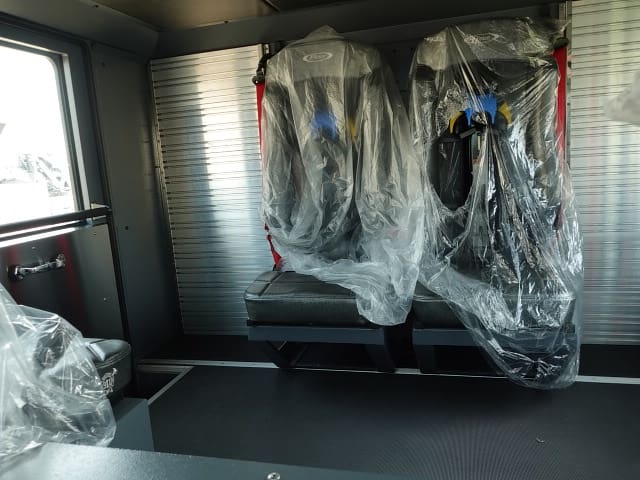

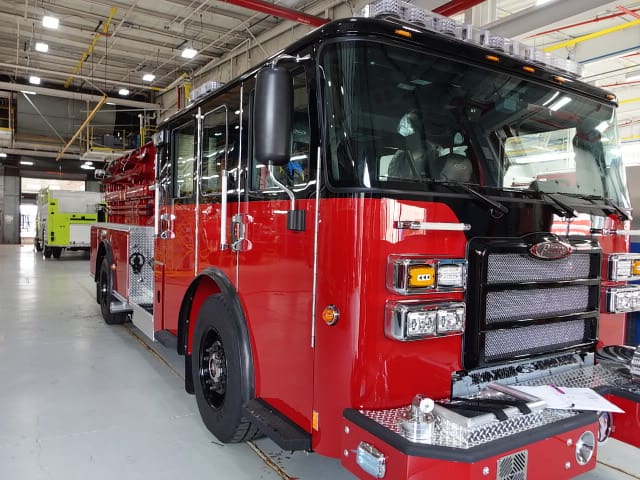

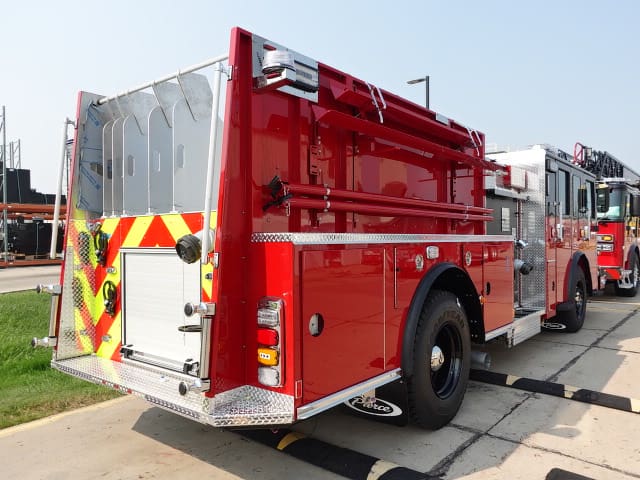

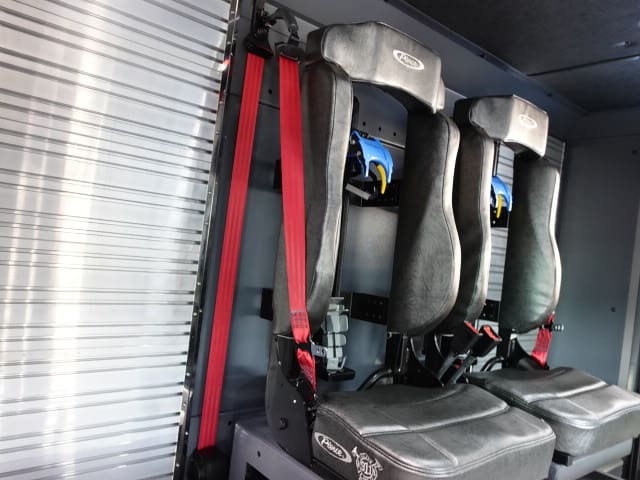

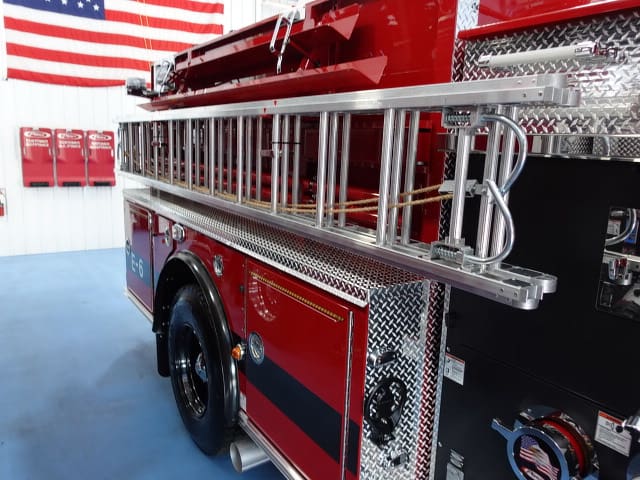

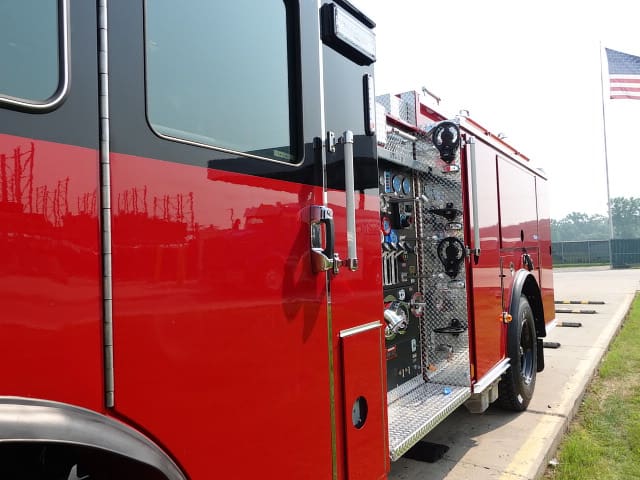

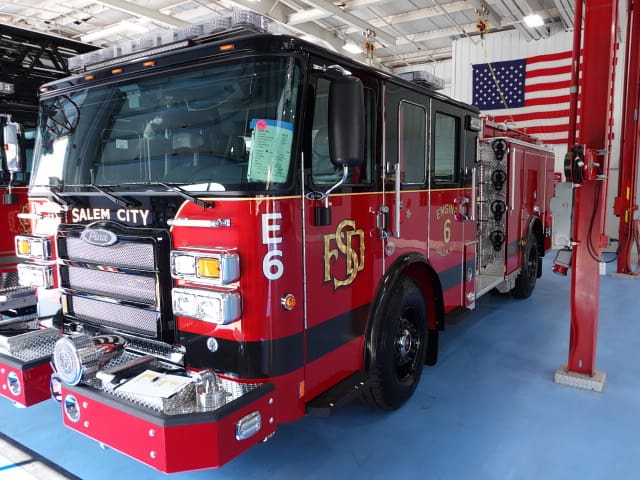

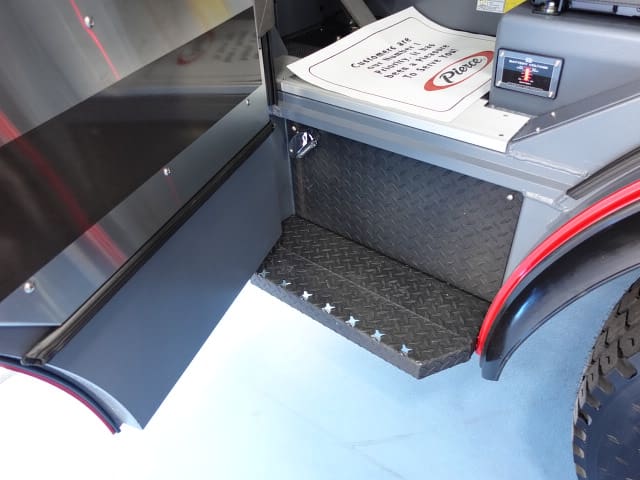

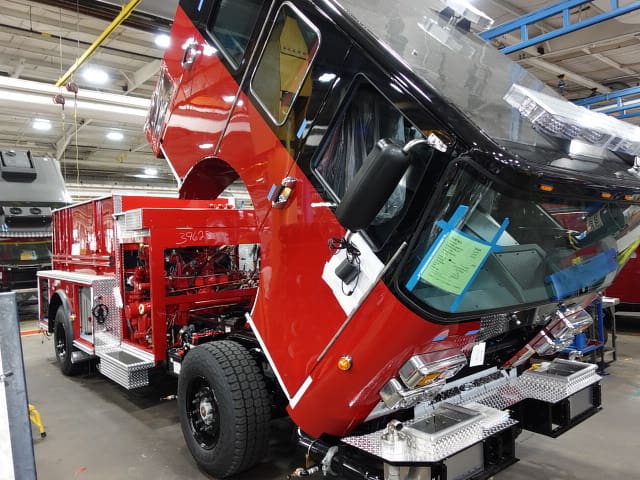

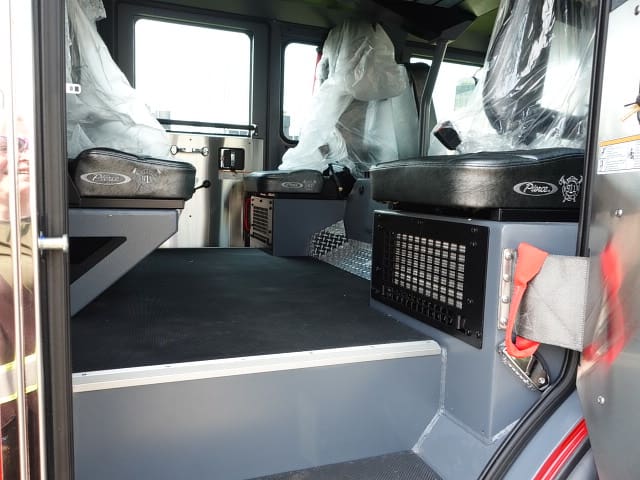

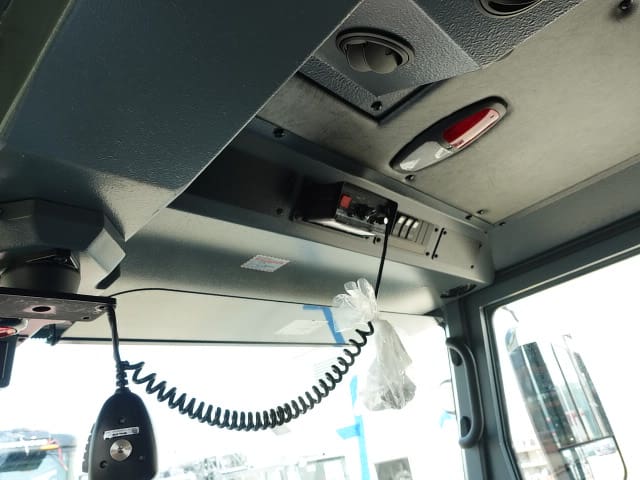

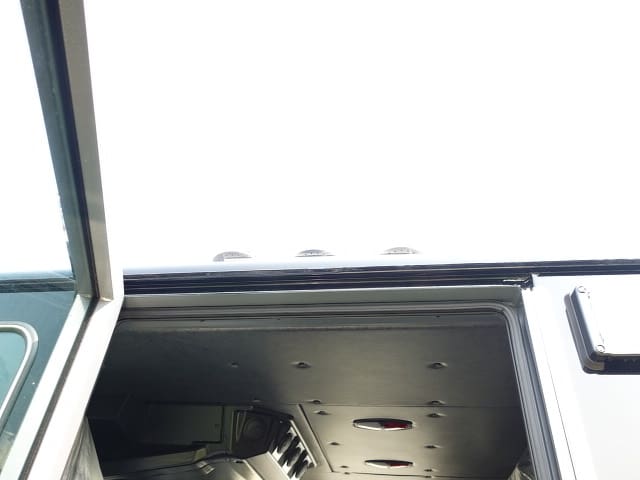

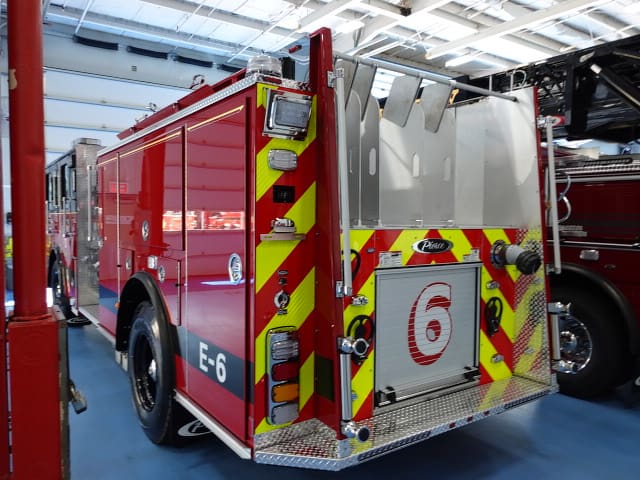

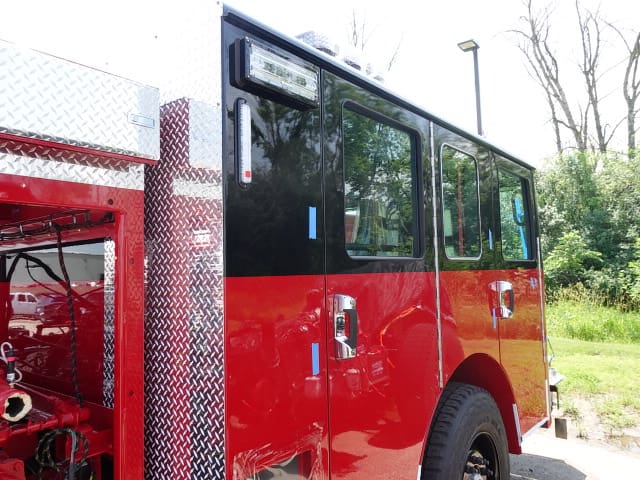

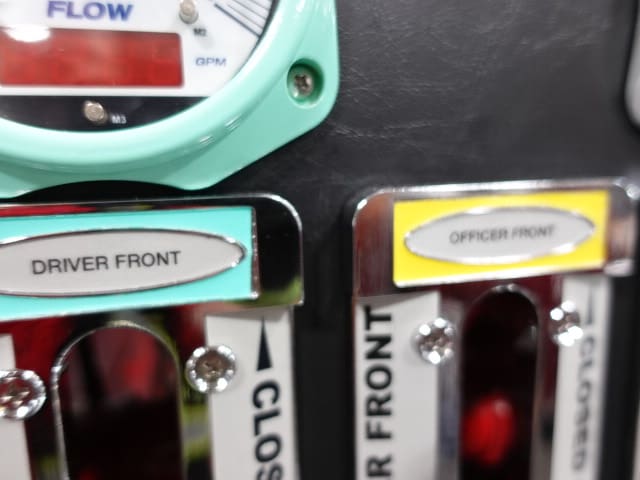

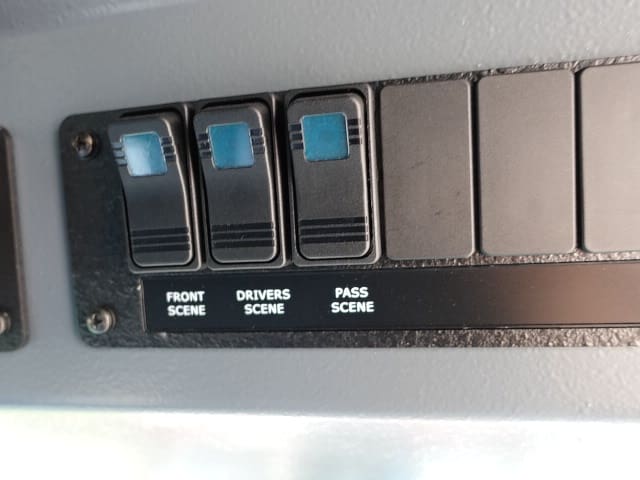

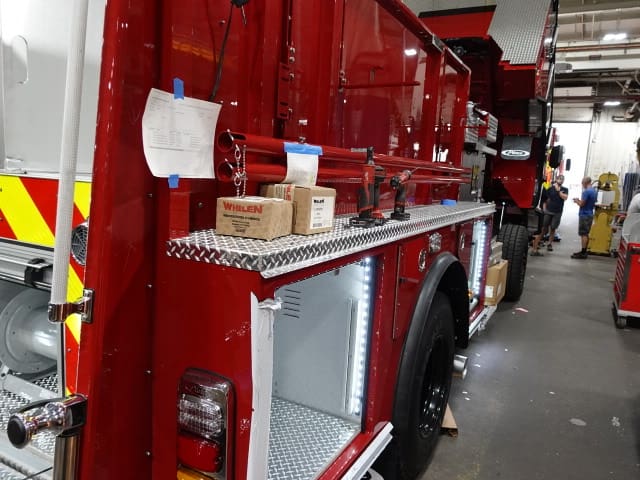

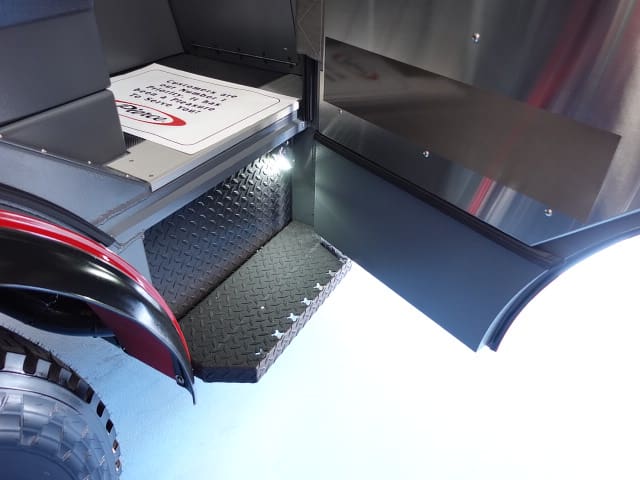

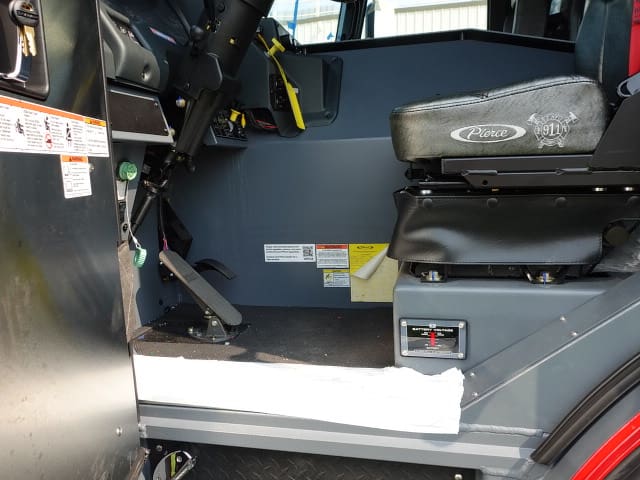

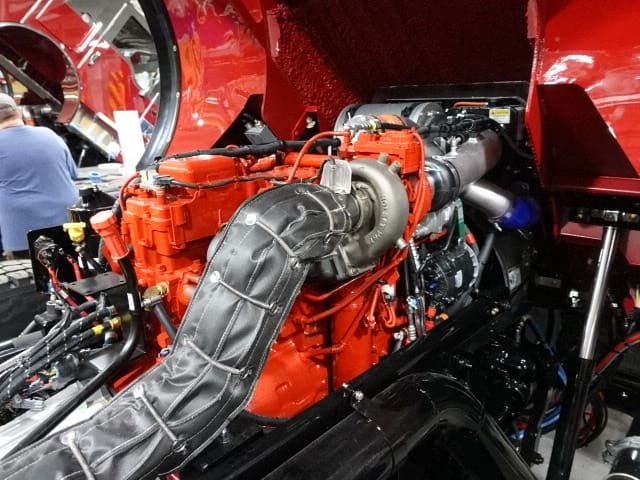

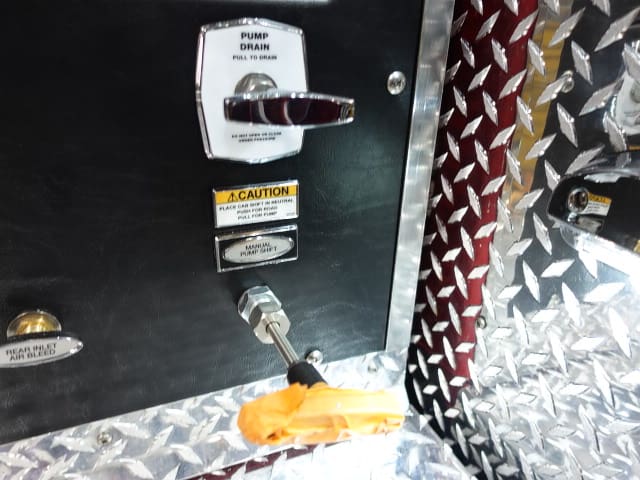

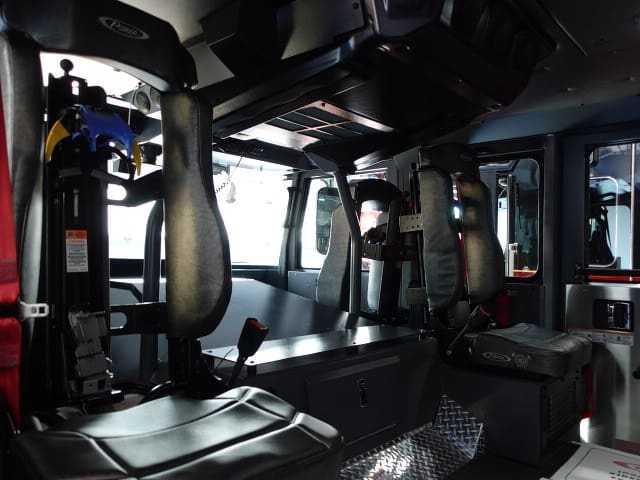

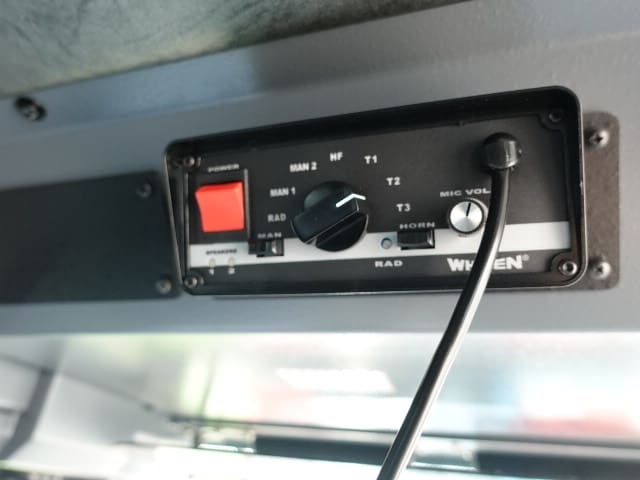

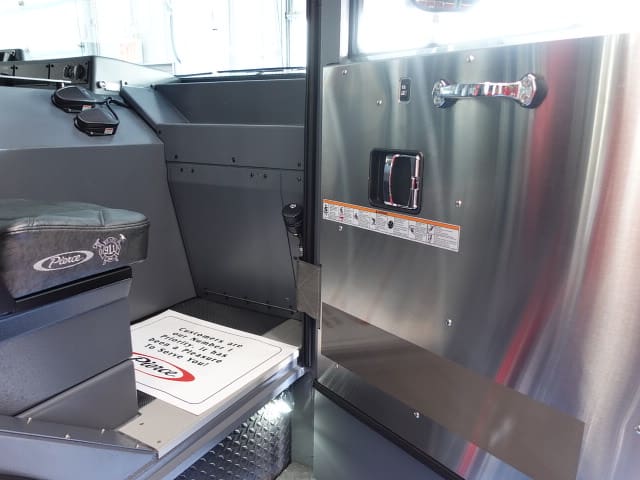

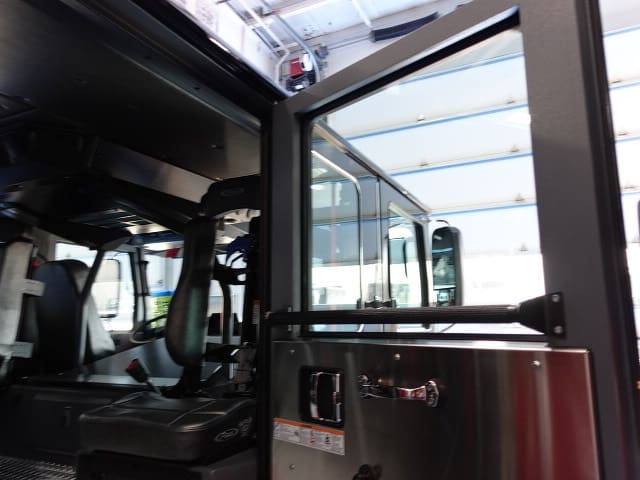

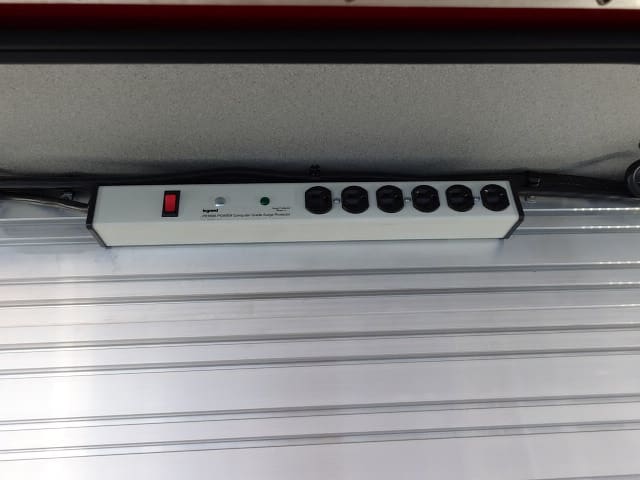

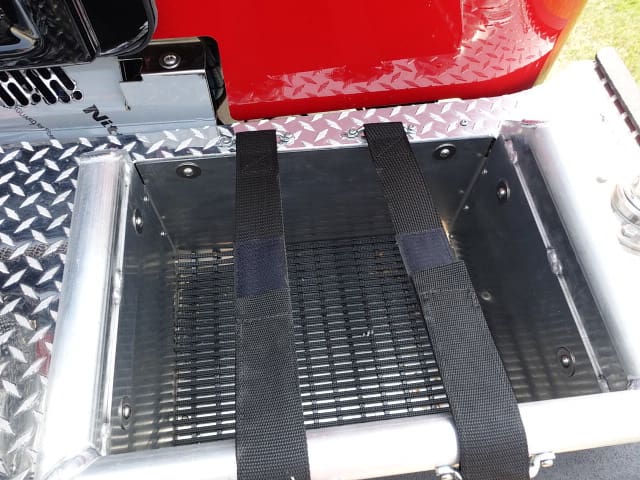

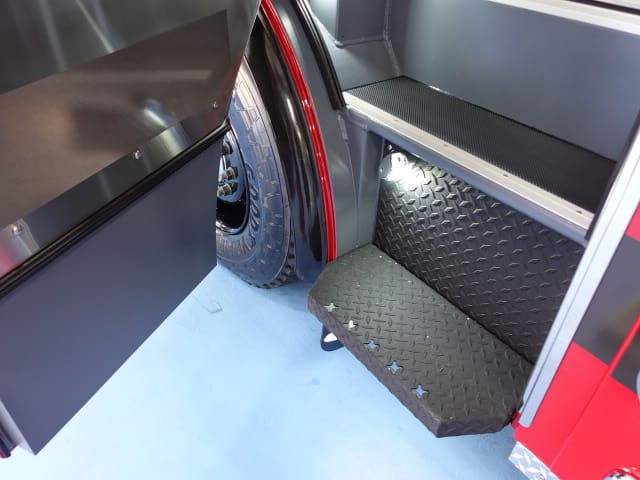

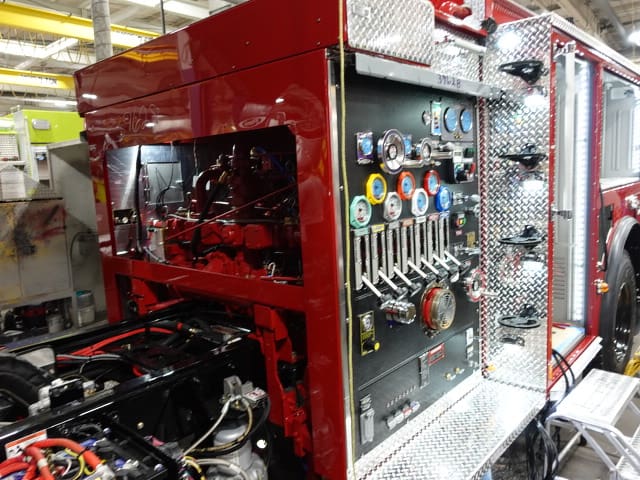

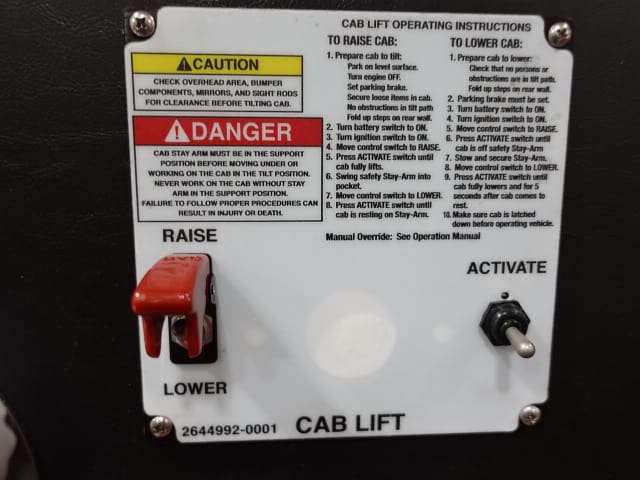

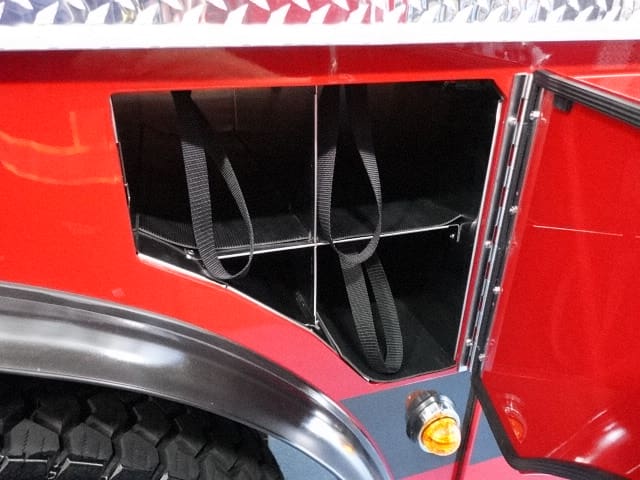

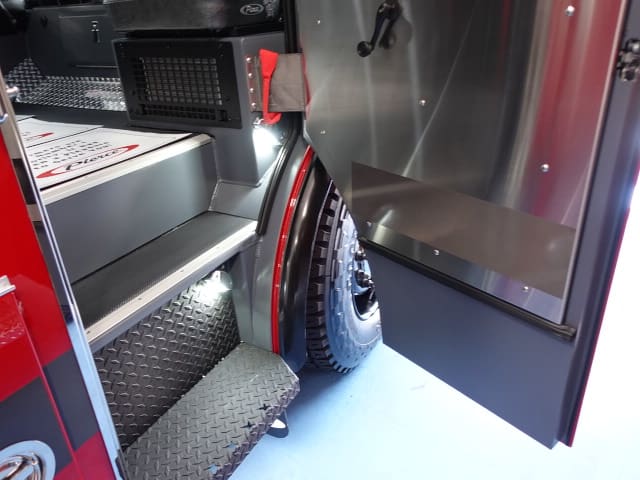

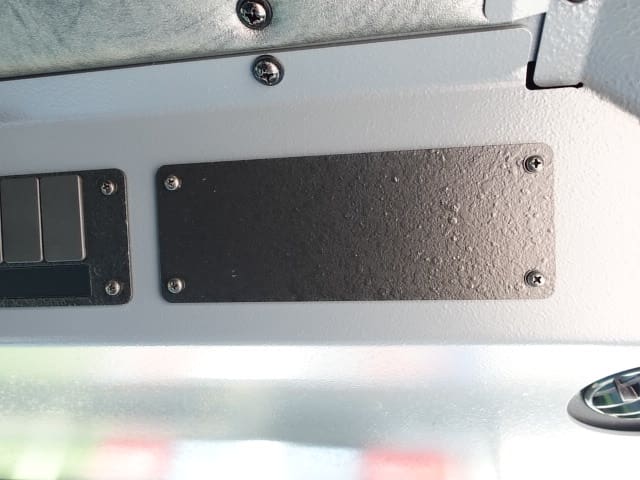

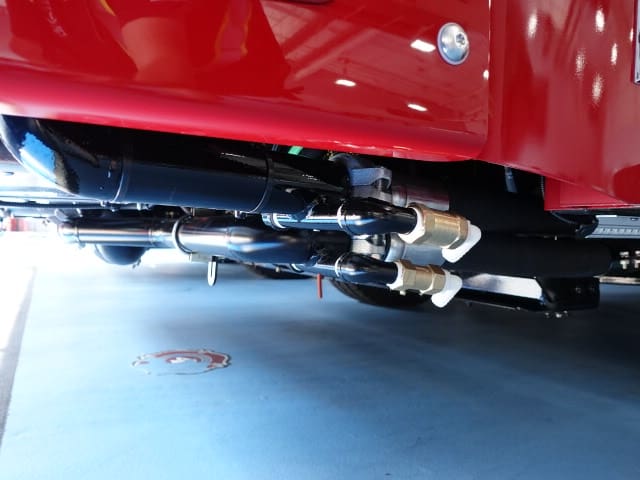

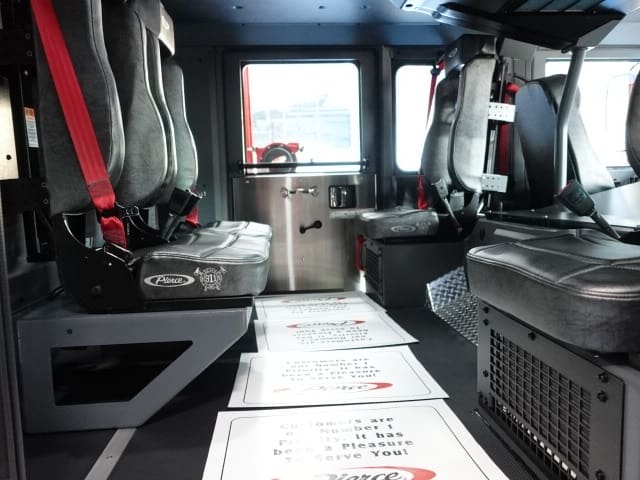

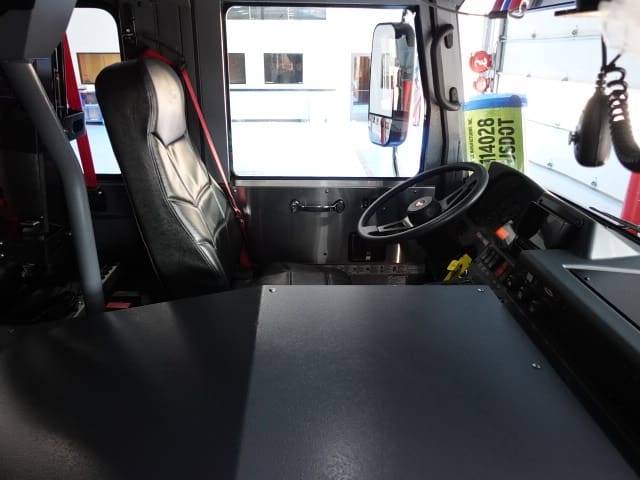

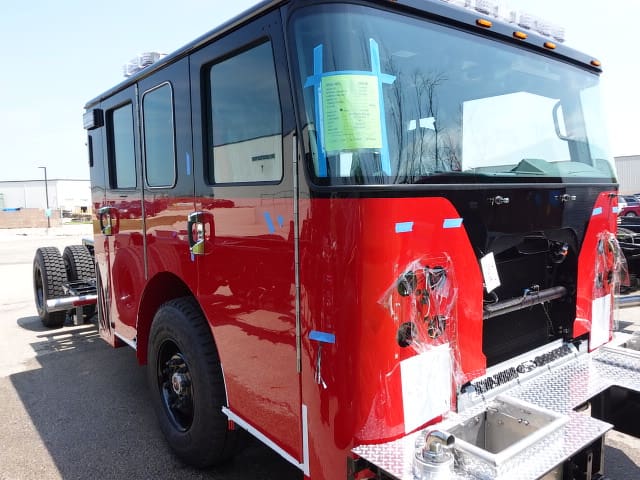

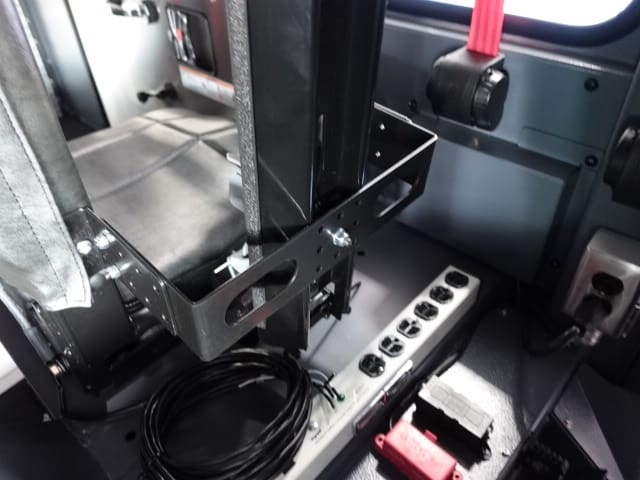

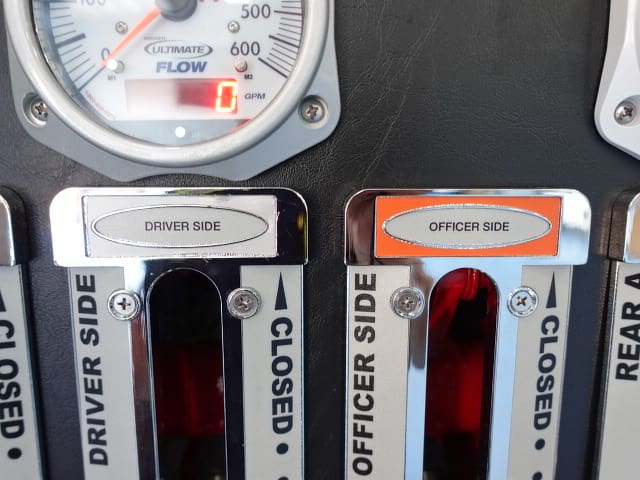

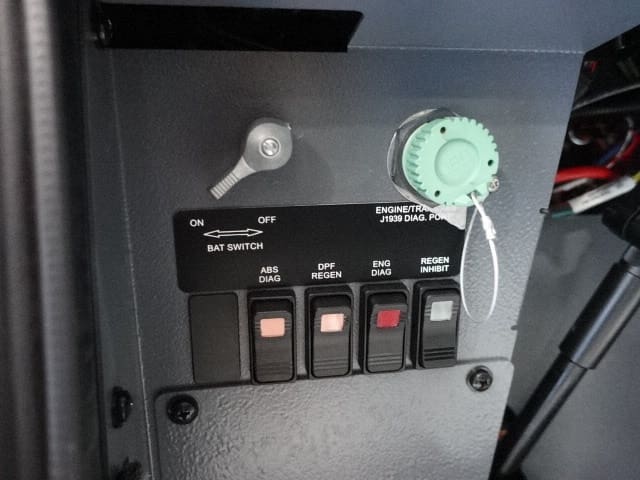

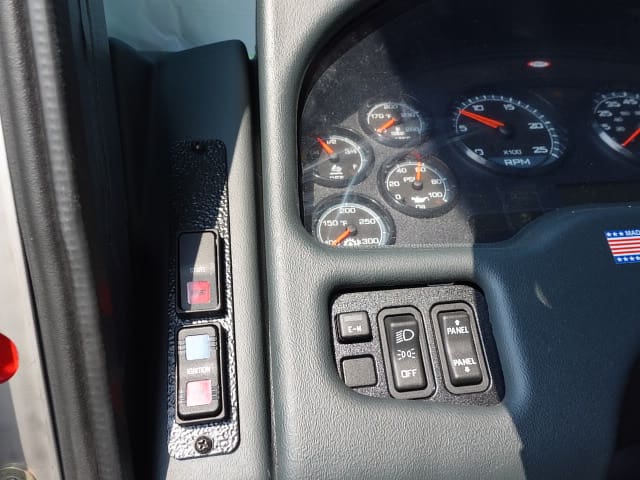

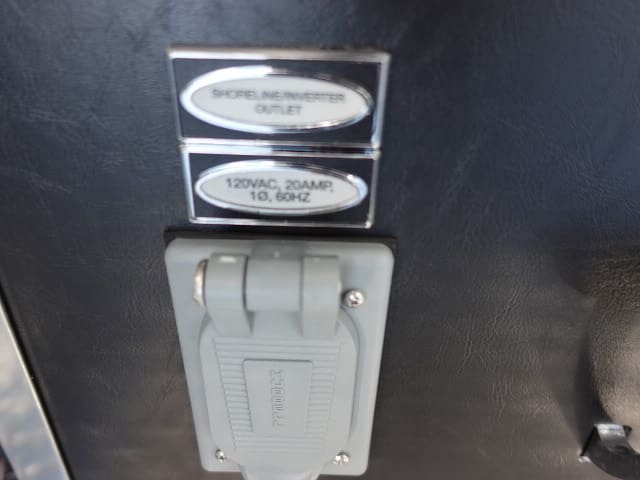

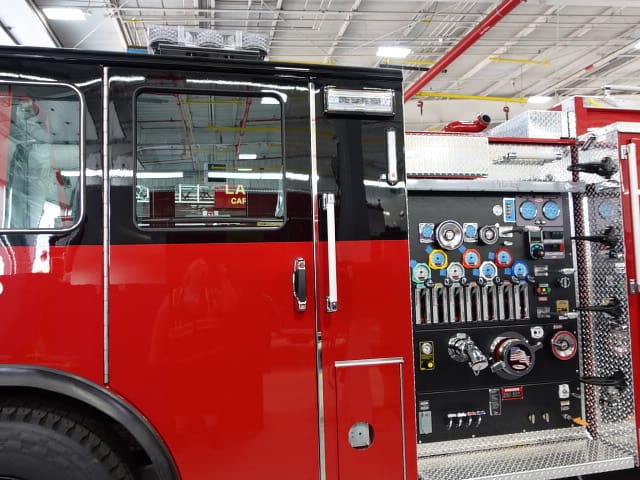

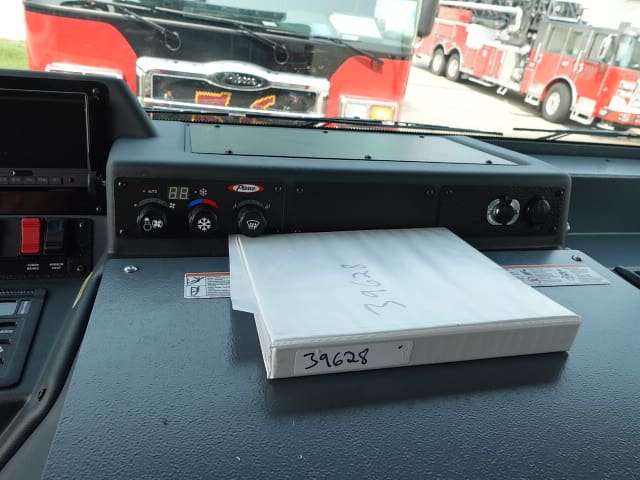

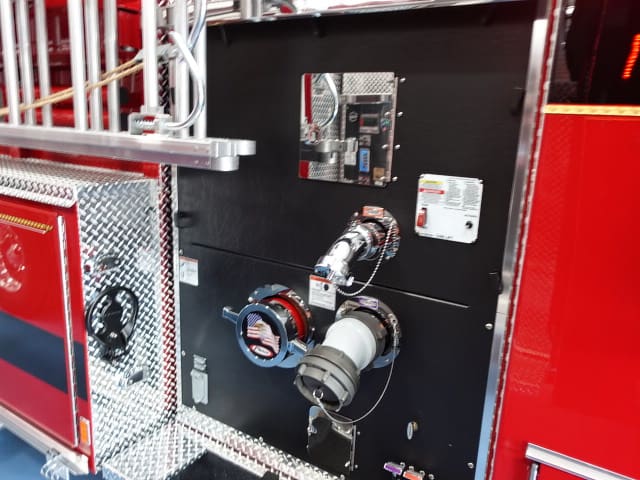

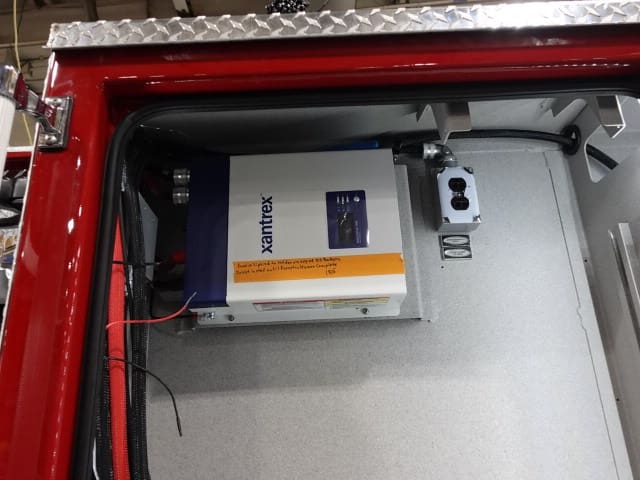

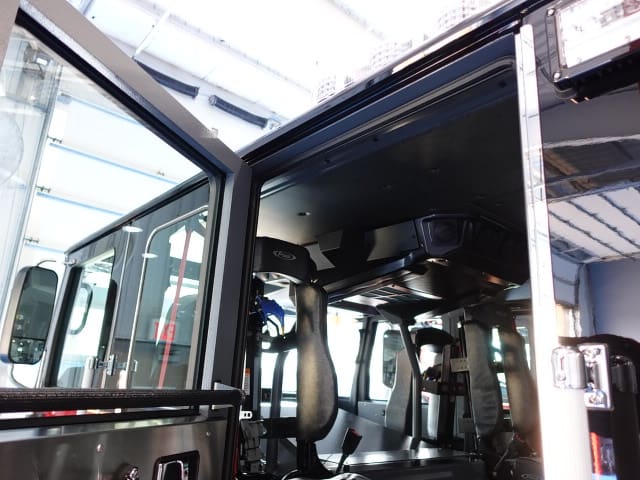

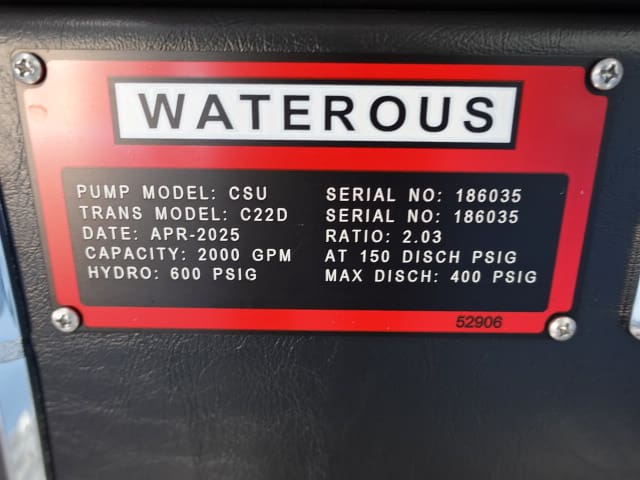

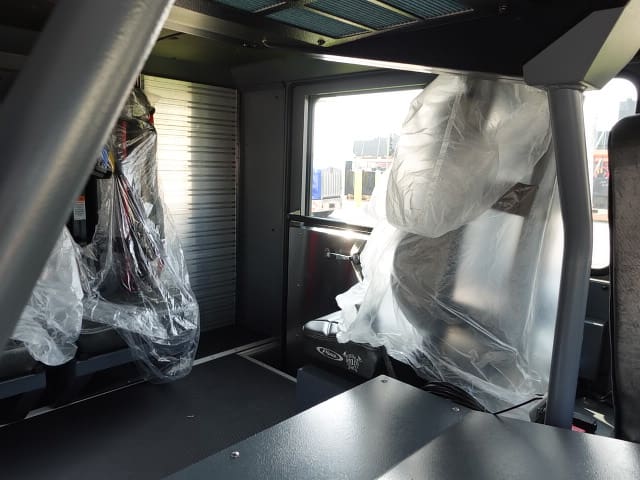

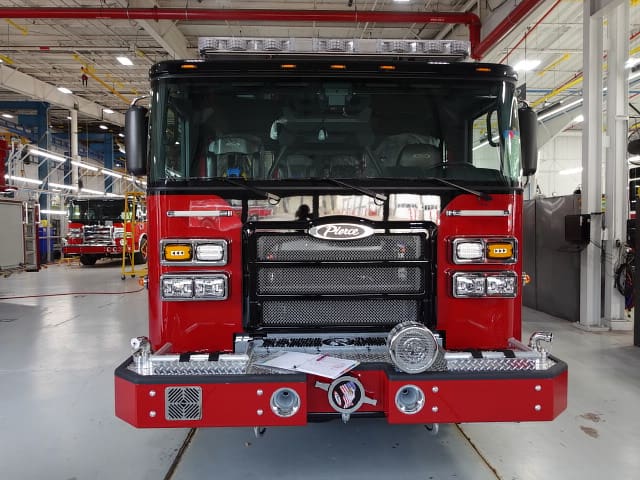

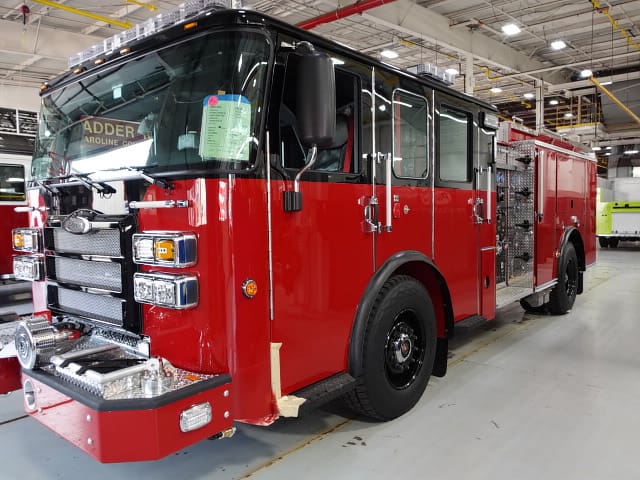

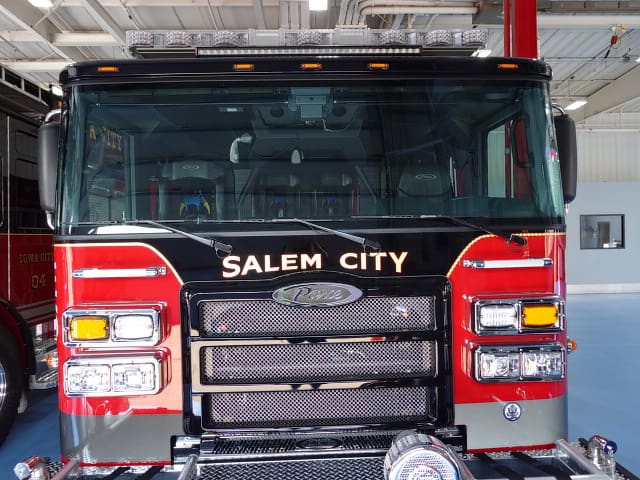

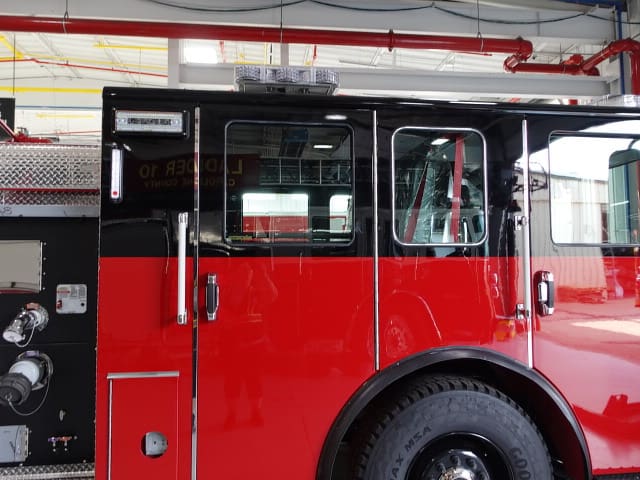

In this report, the apparatus completed quality and graphics where any remaining content is applied. It was then made ready for the customer acceptance inspection. This is the last scheduled report.
08-08-25

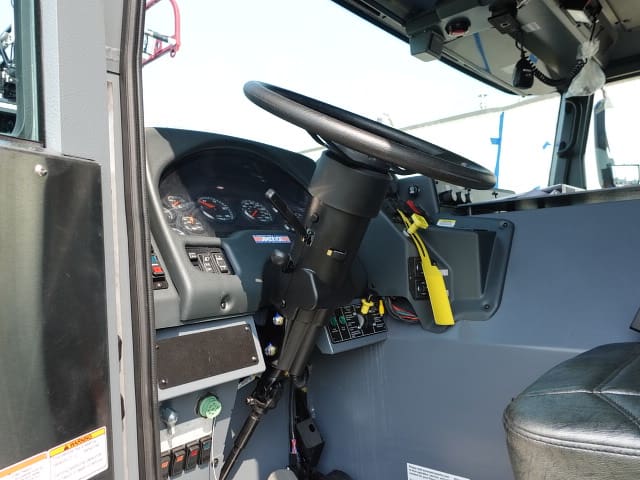

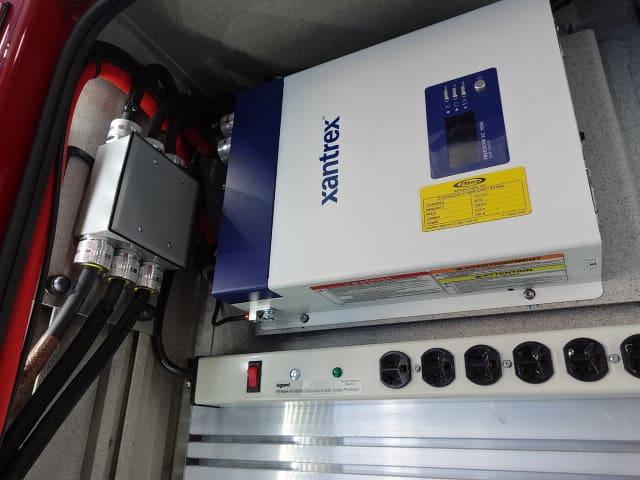

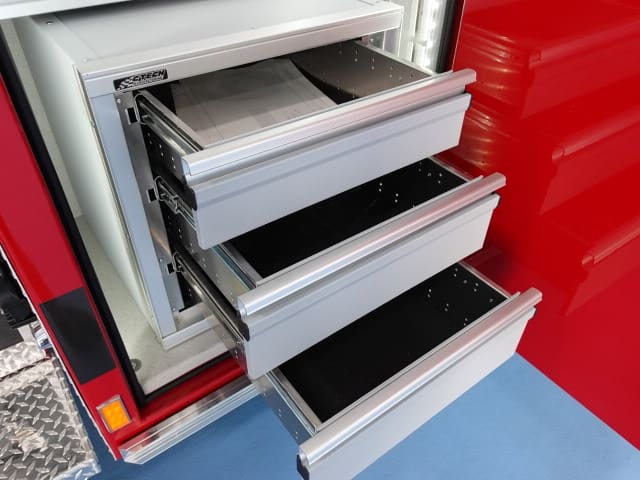

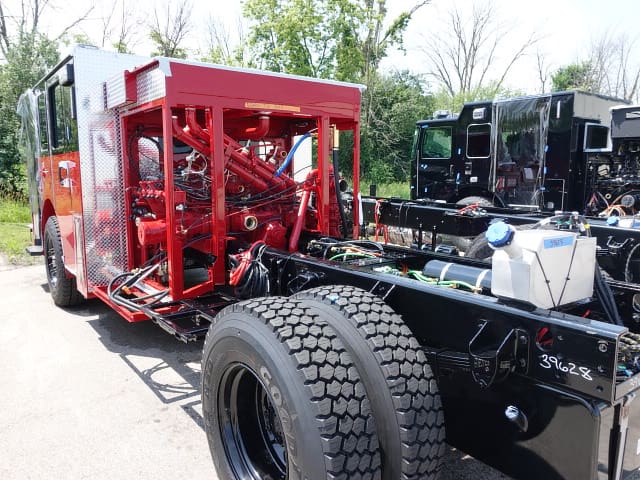

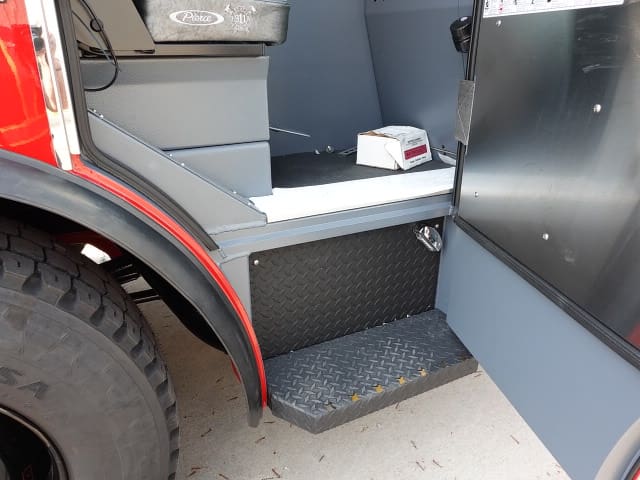

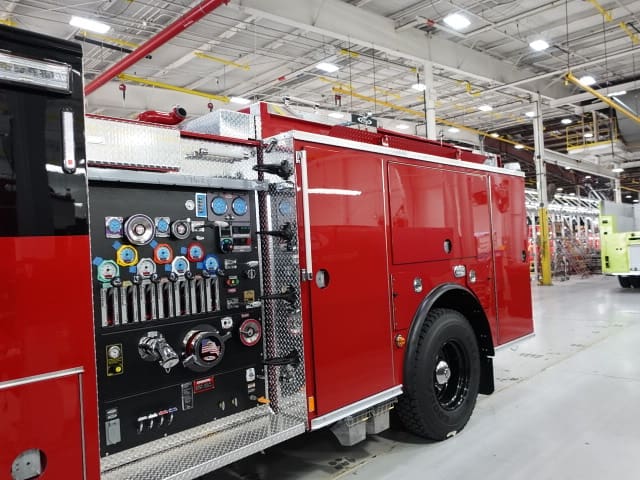

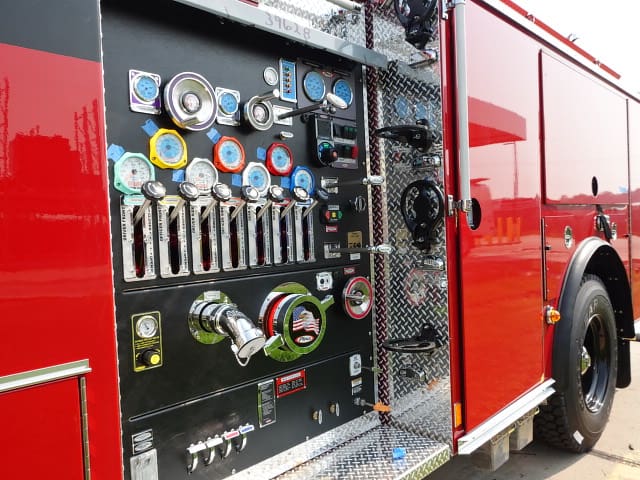

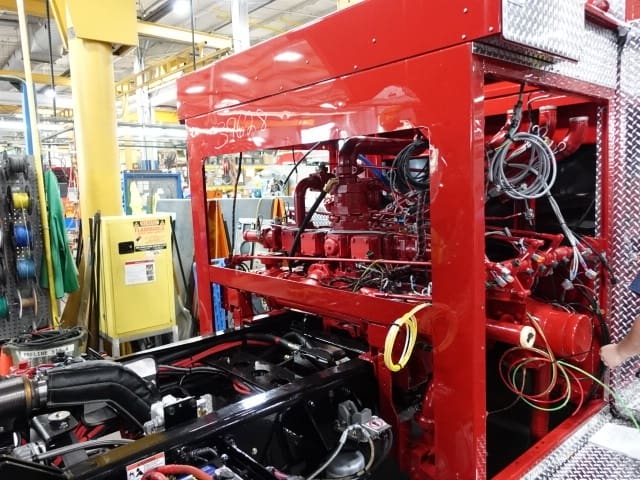

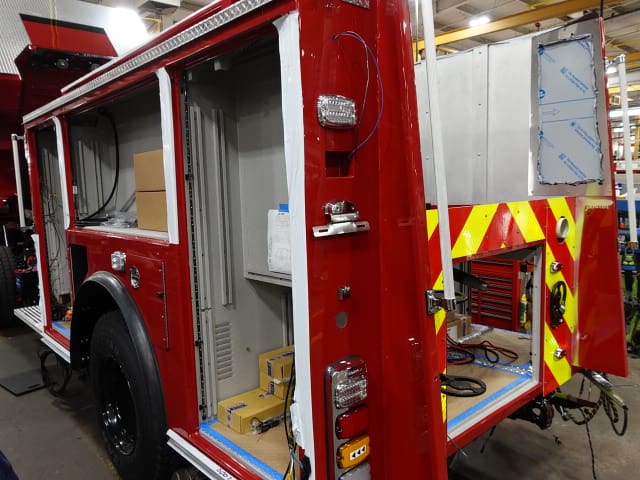

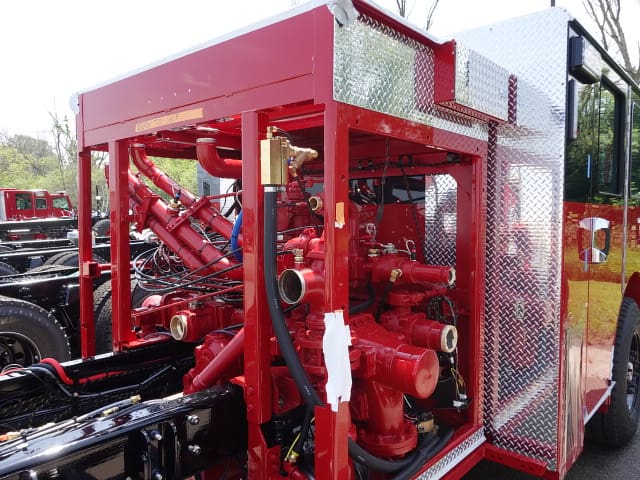

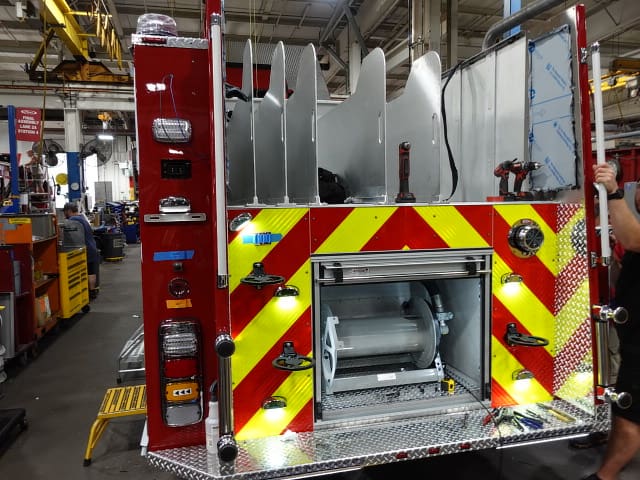

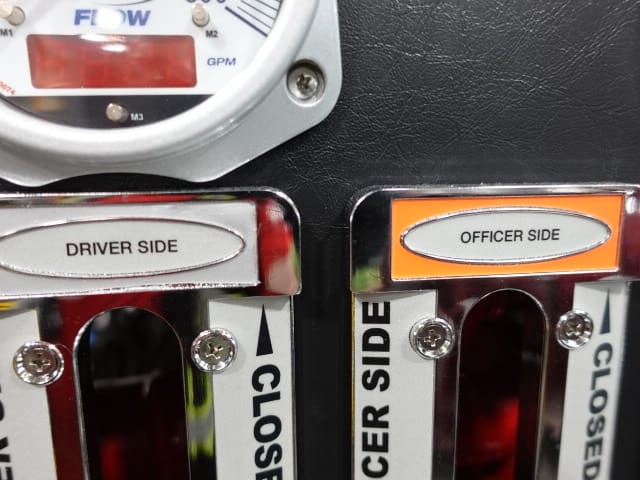

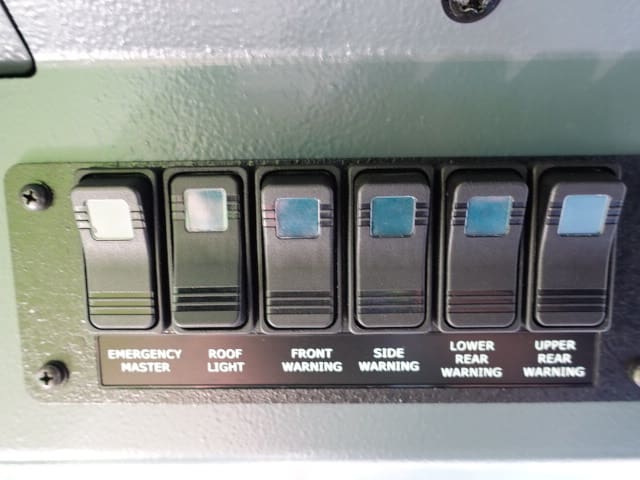

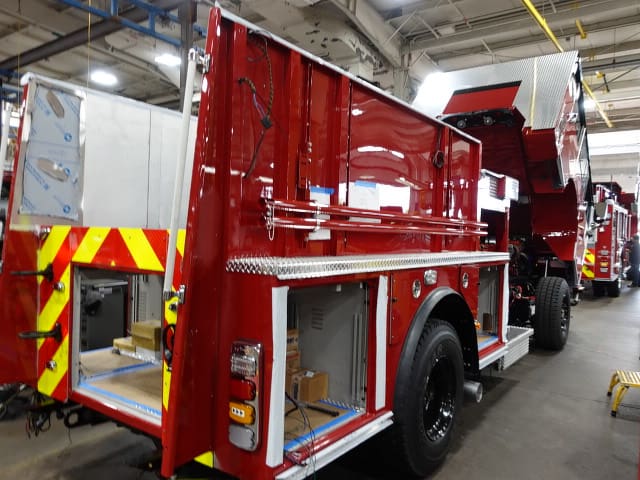

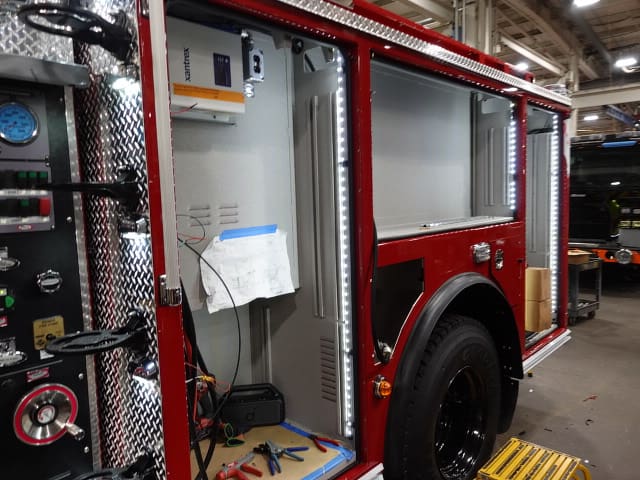

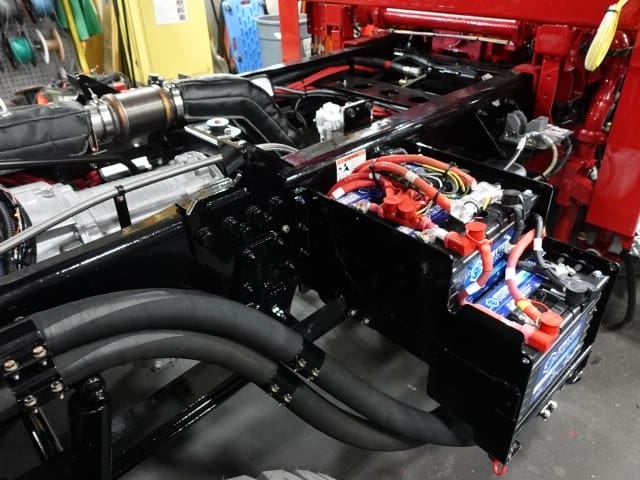

In this report, the apparatus completed test and was released to quality and graphics where any remaining content will be applied.
07-18-25

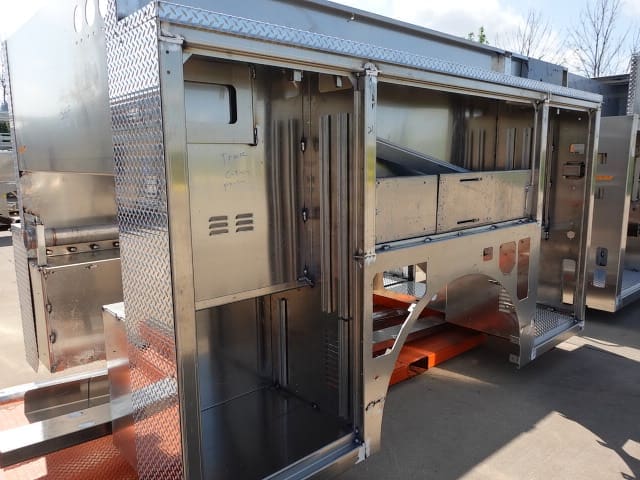

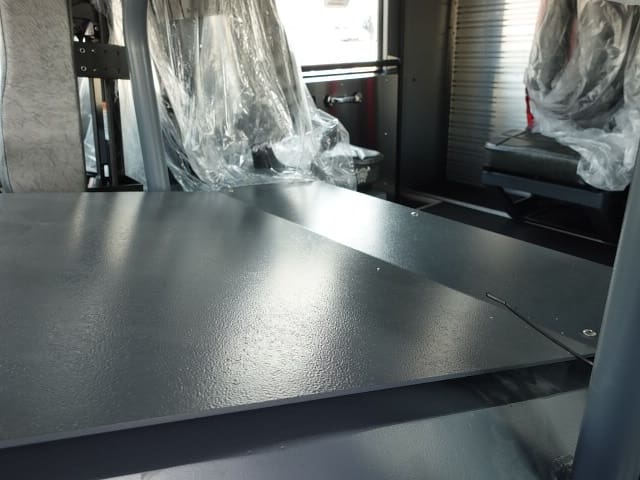

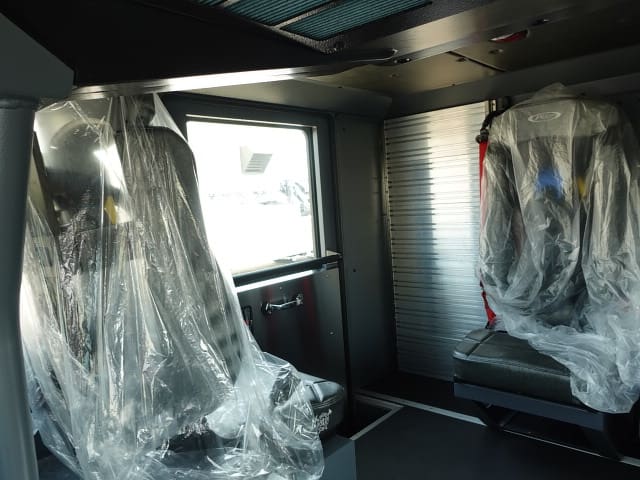

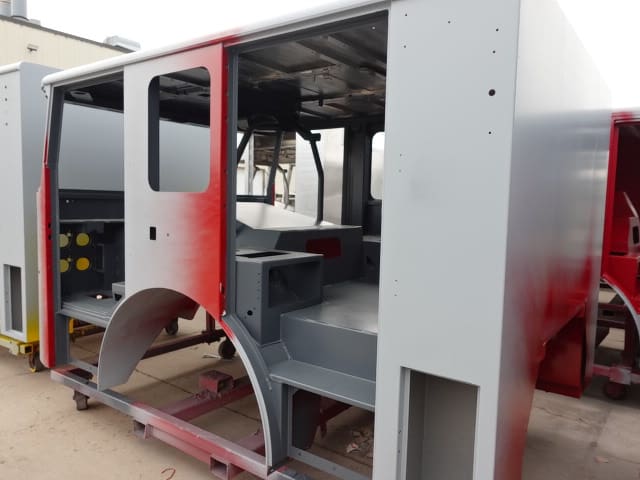

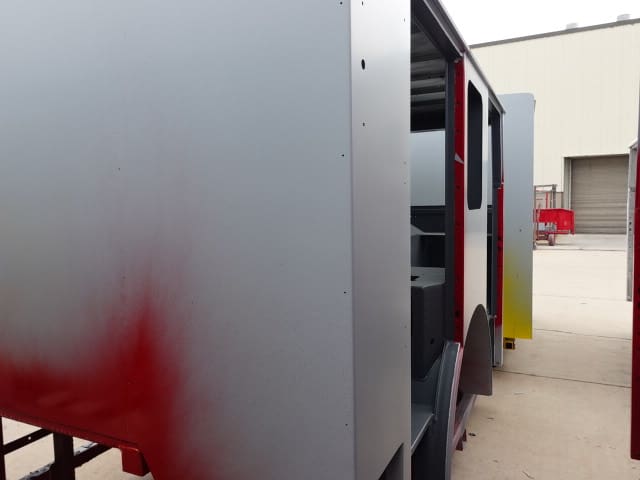

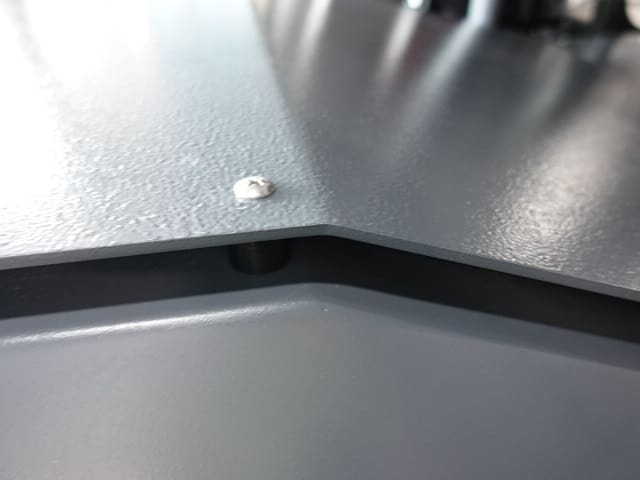

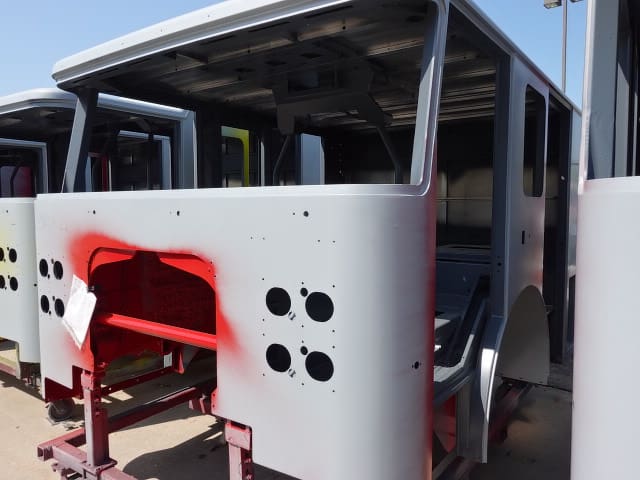

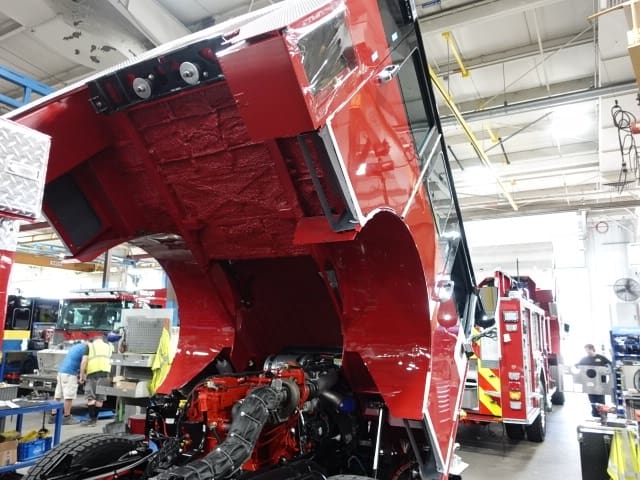

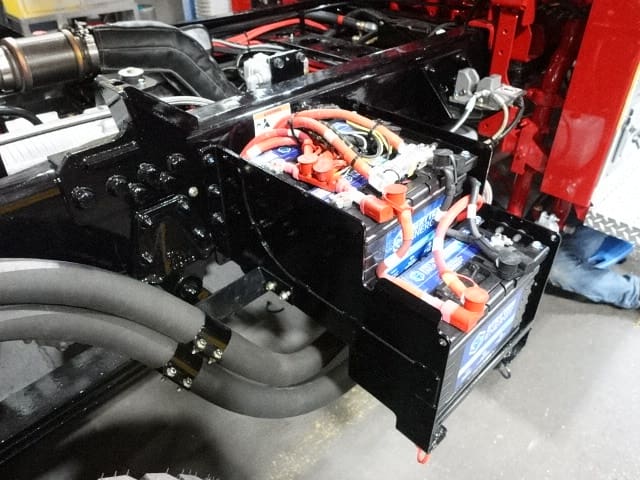

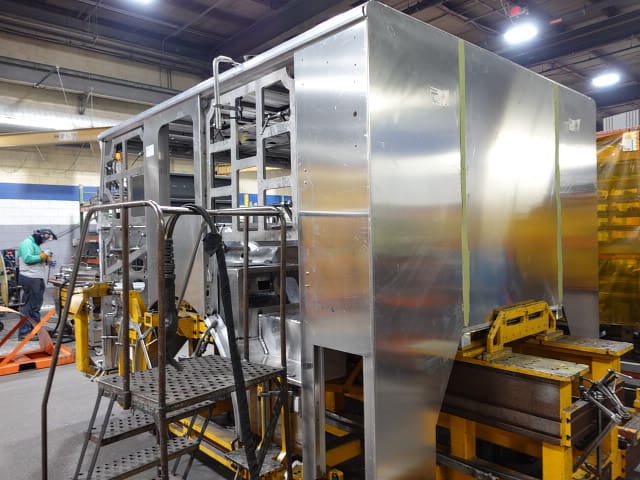

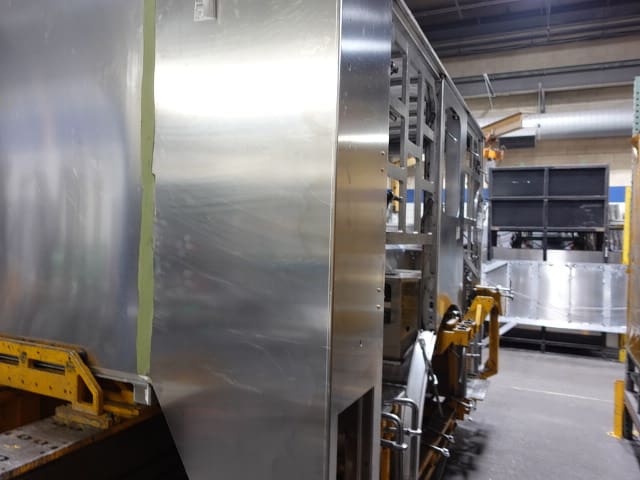

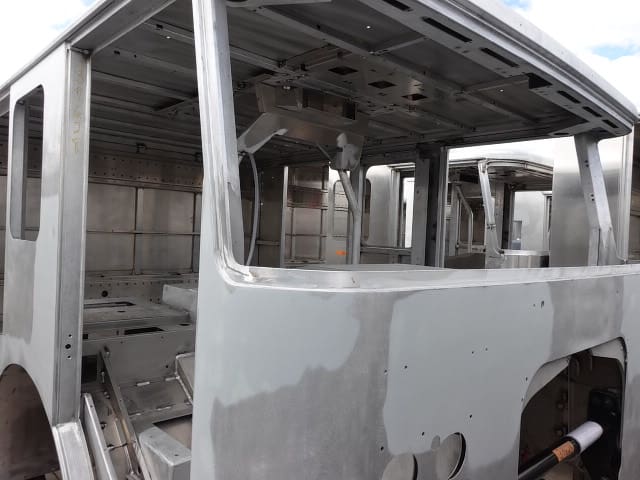

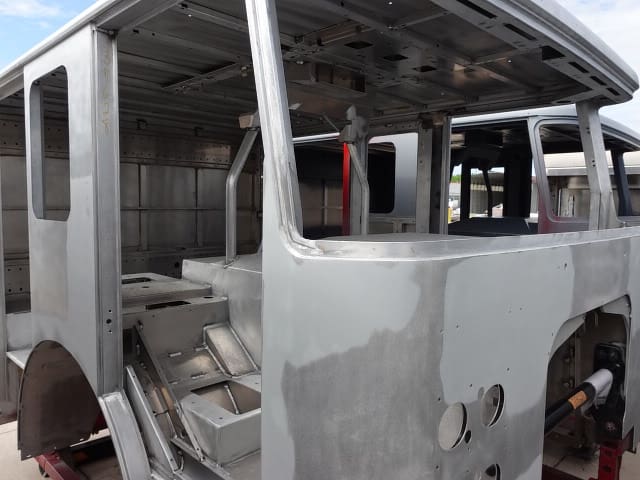

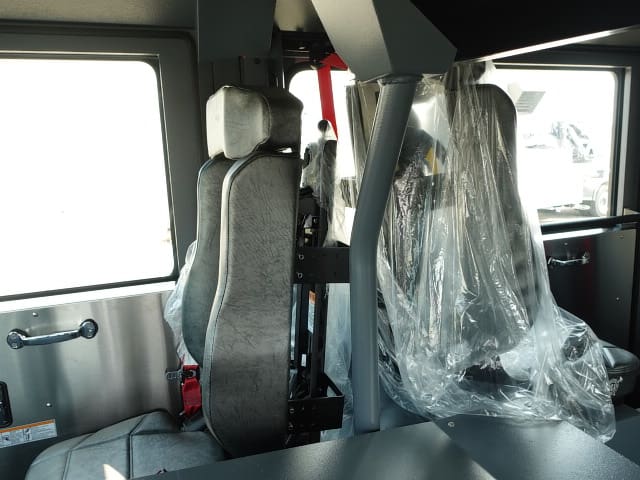

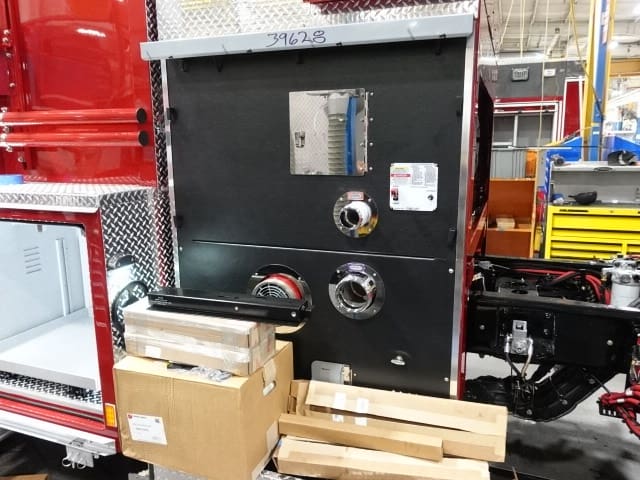

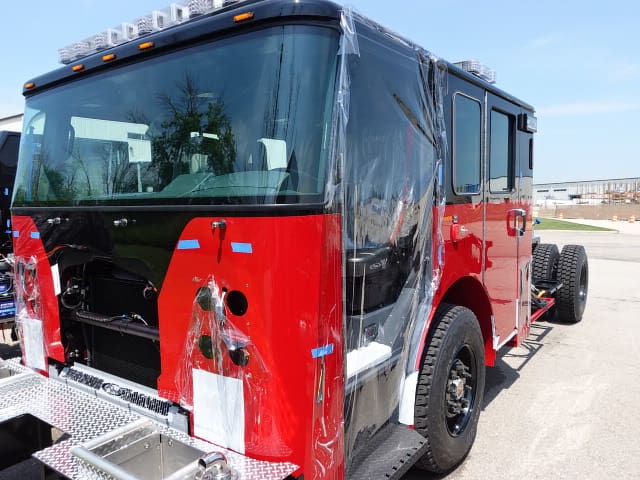

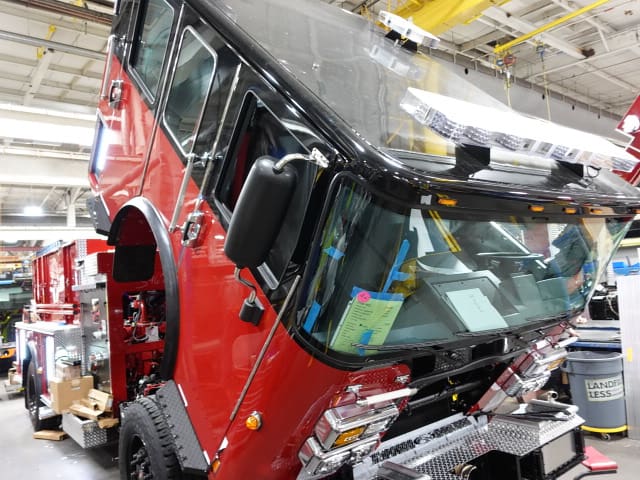

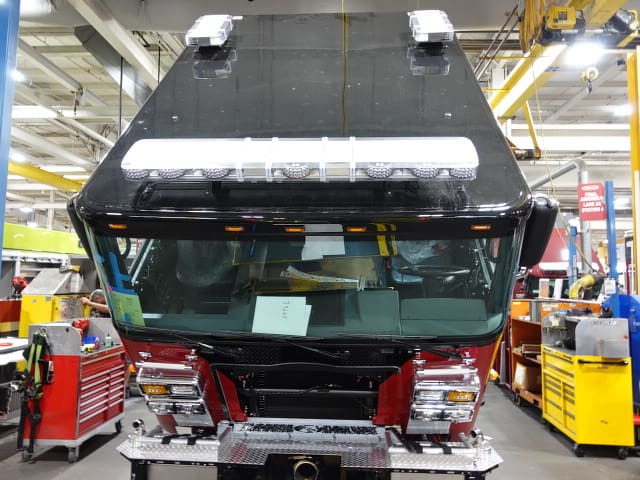

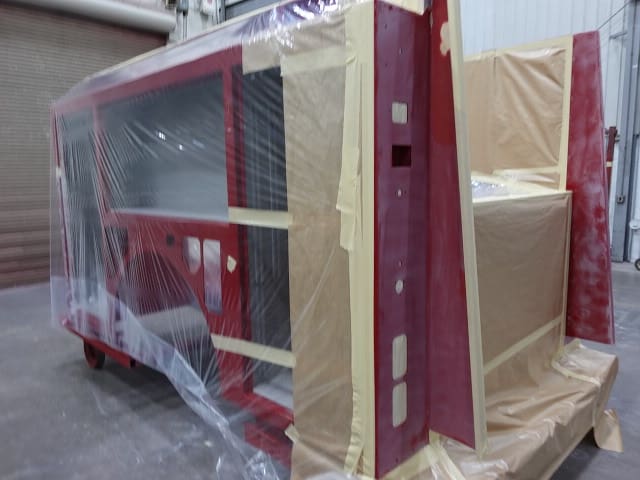

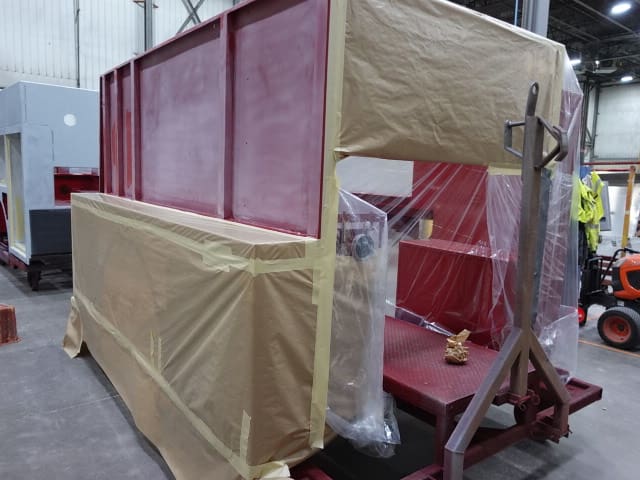

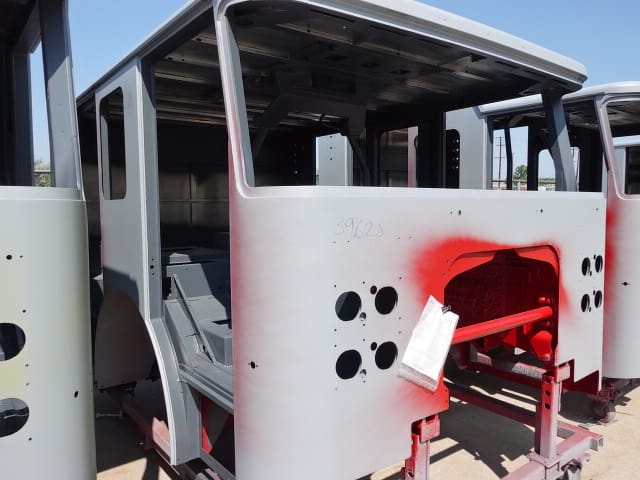

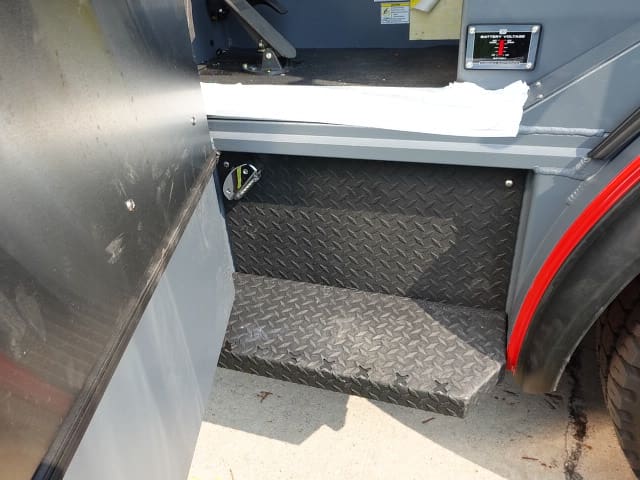

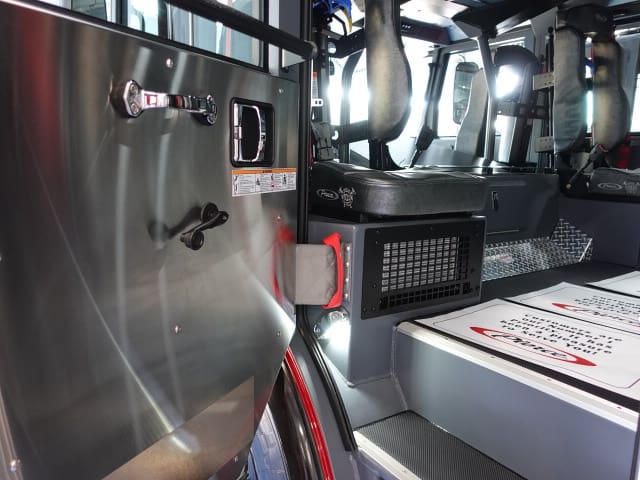

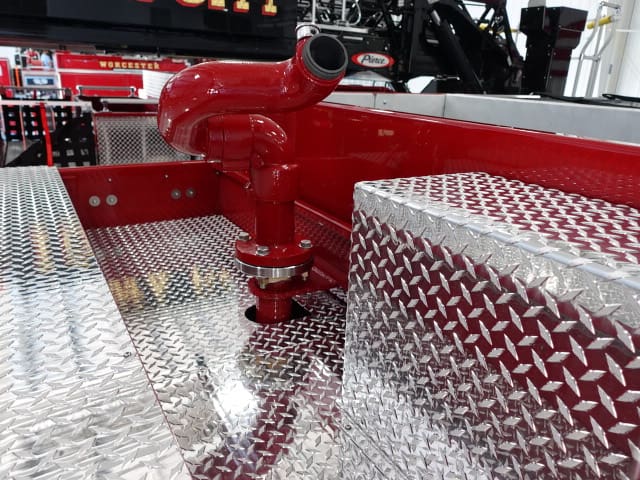

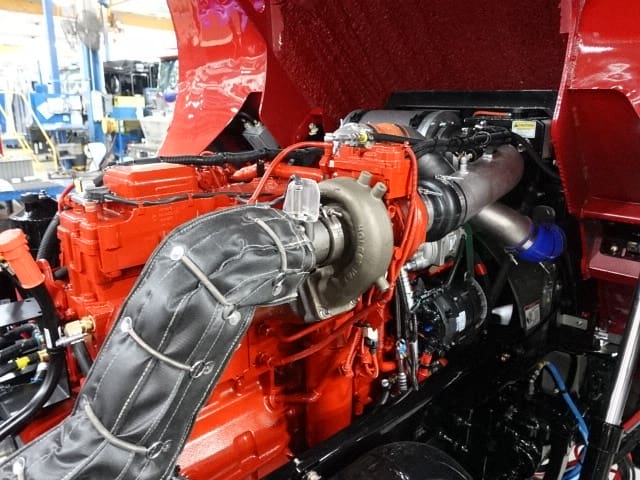

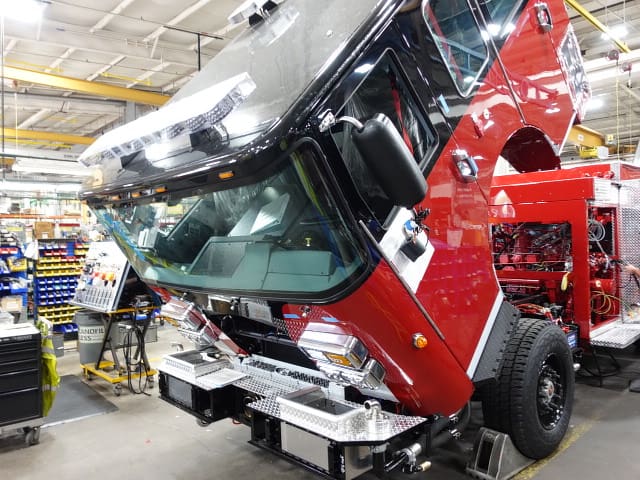

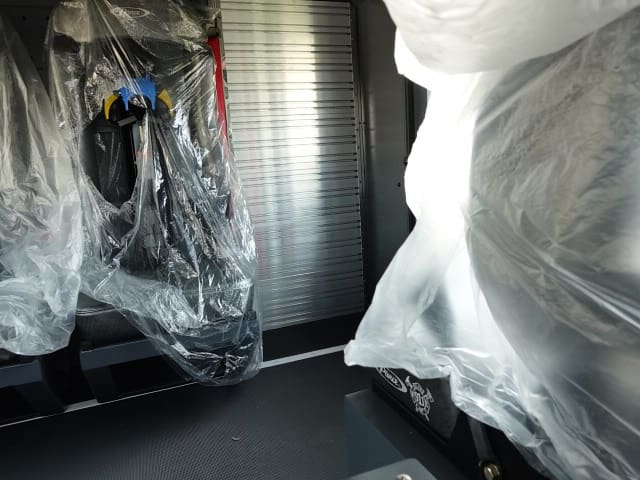

In this report, the body completed the paint process and initial assembly then was installed on the chassis.

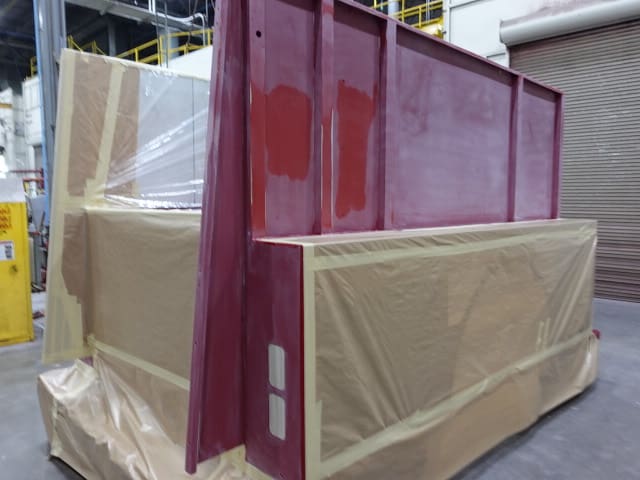

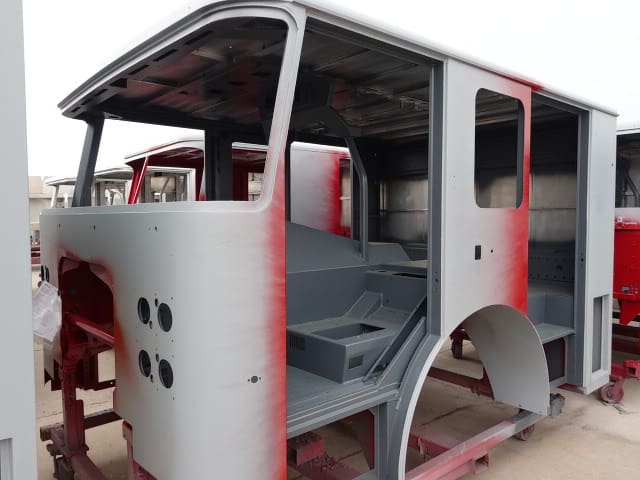

07-11-25

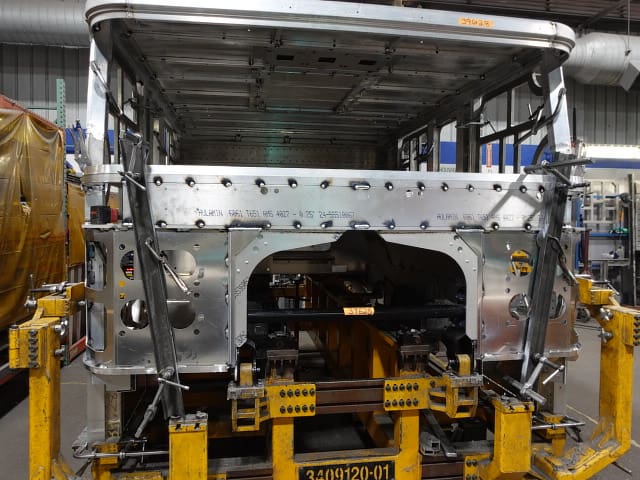

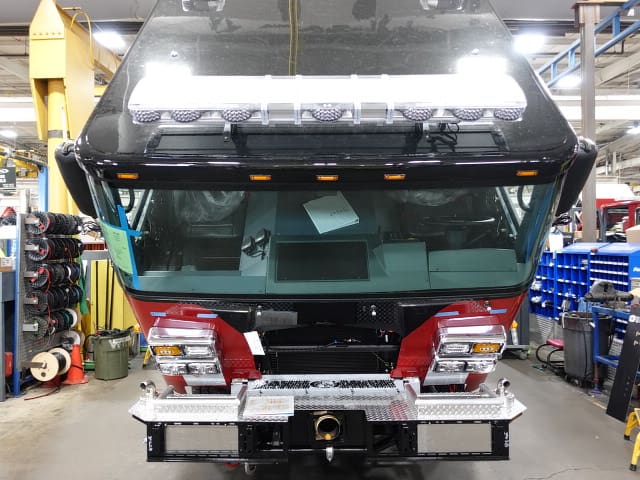

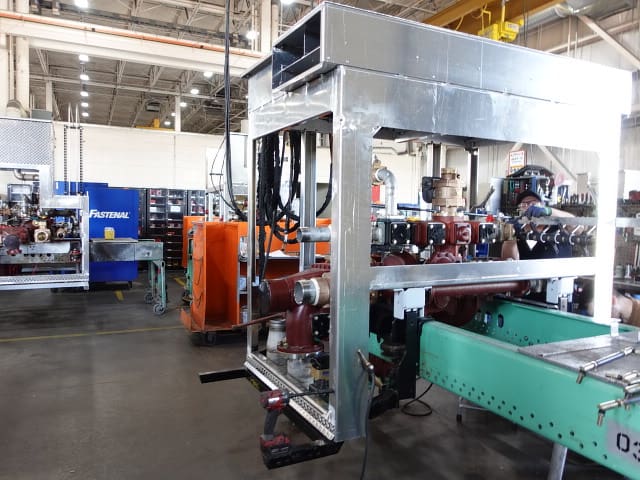

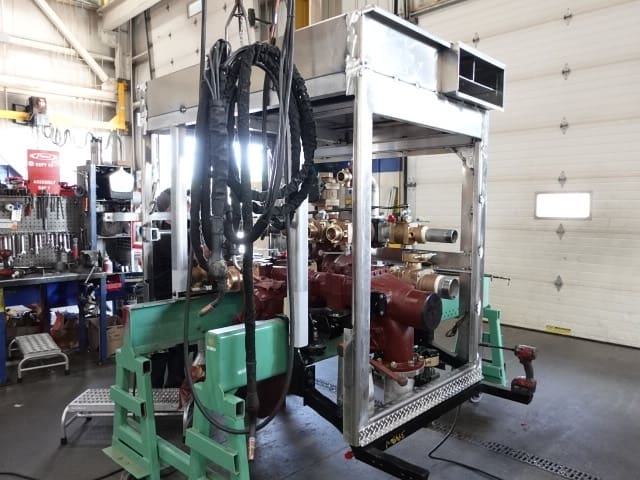

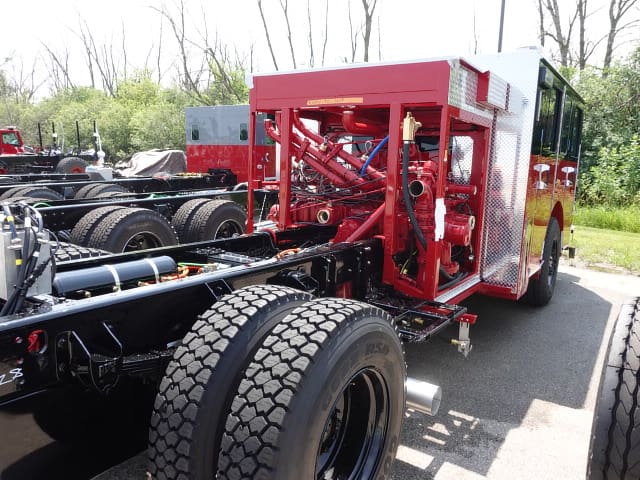

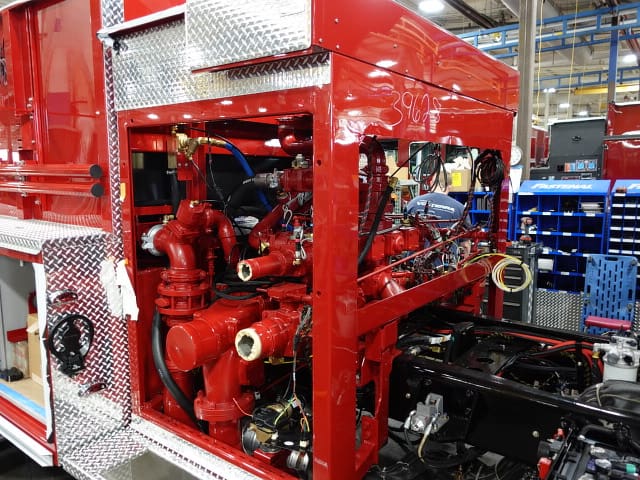

In this report, the cab and pump house were installed on the frame while the body began the paint process.

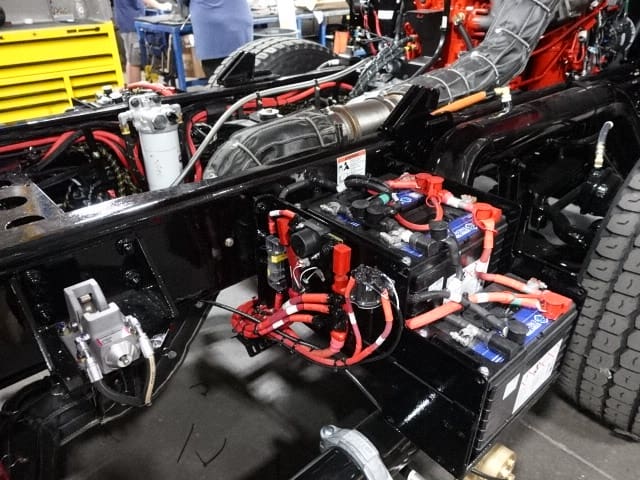

06-20-25

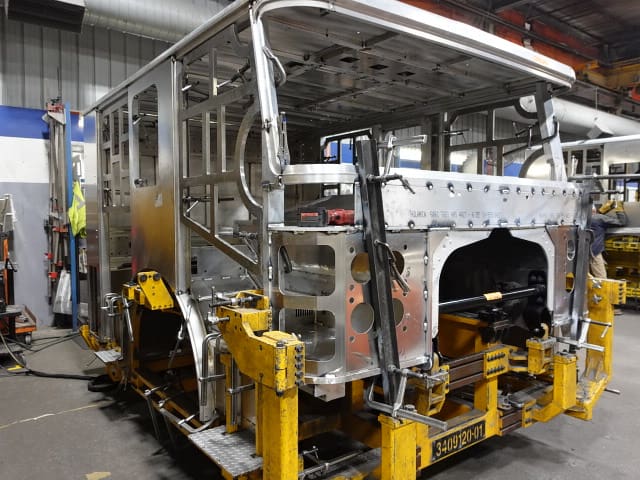

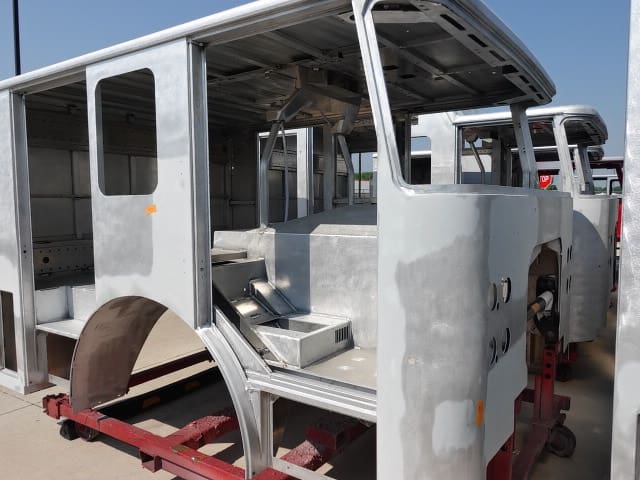

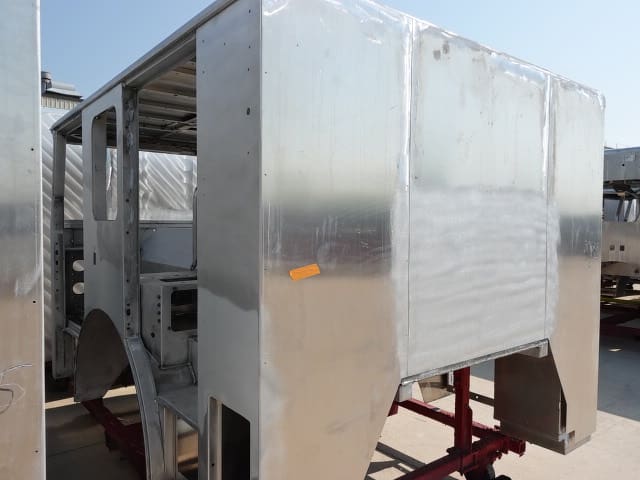

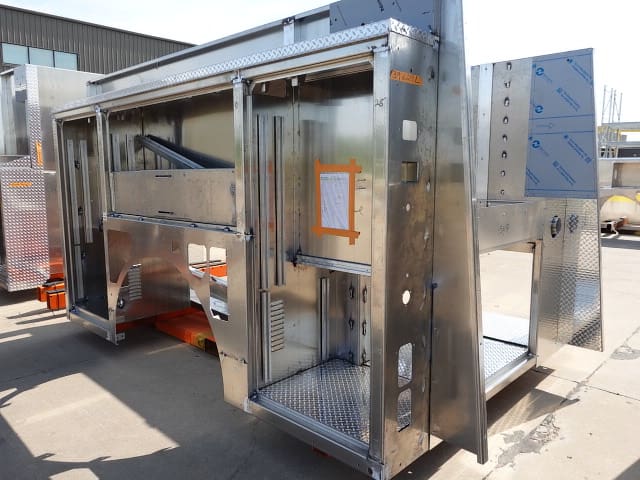

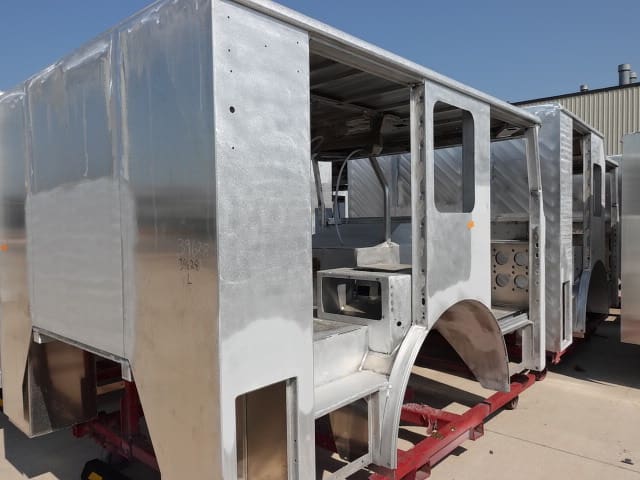

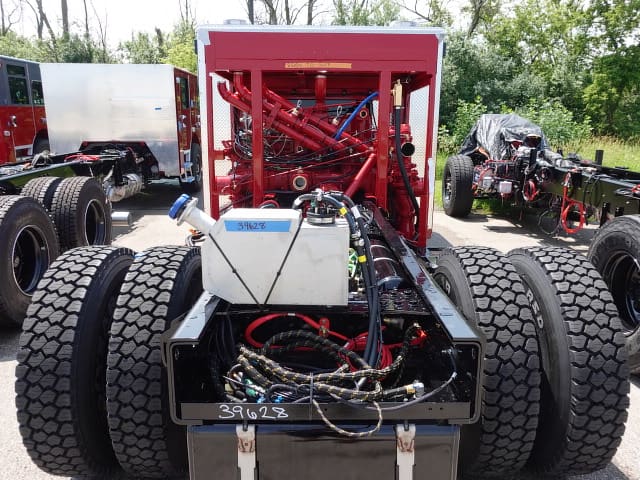

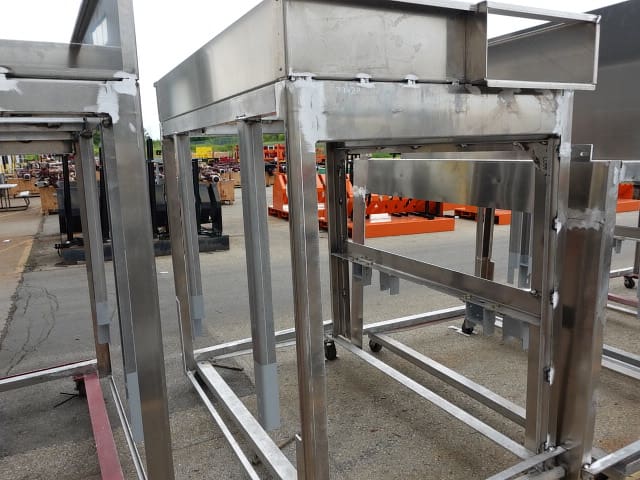

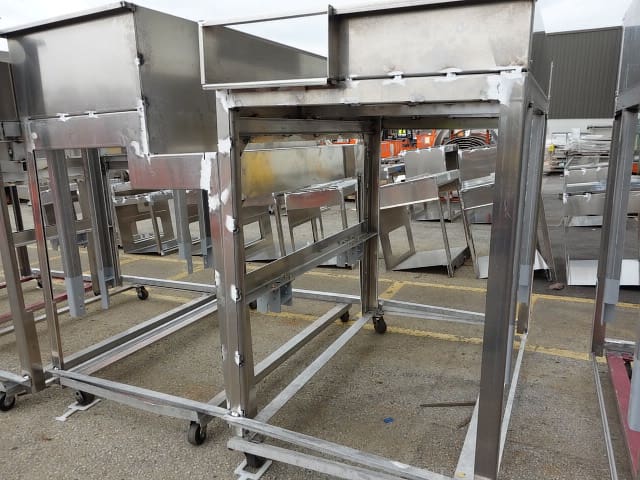

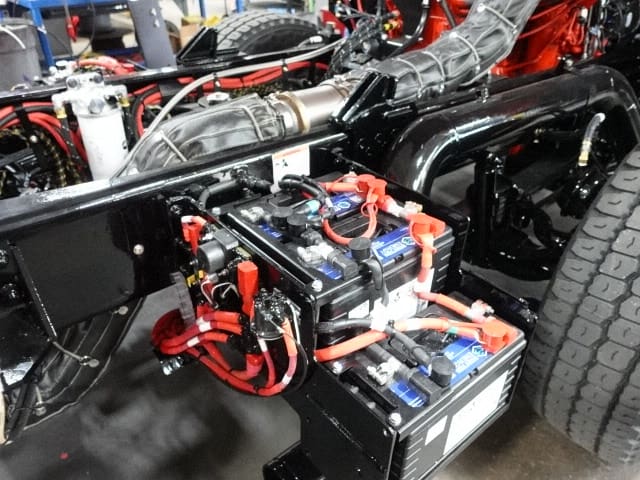

In this report, the cab completed the paint process, the pump house began initial assembly, and the body was fabricated and staged.
06-13-25

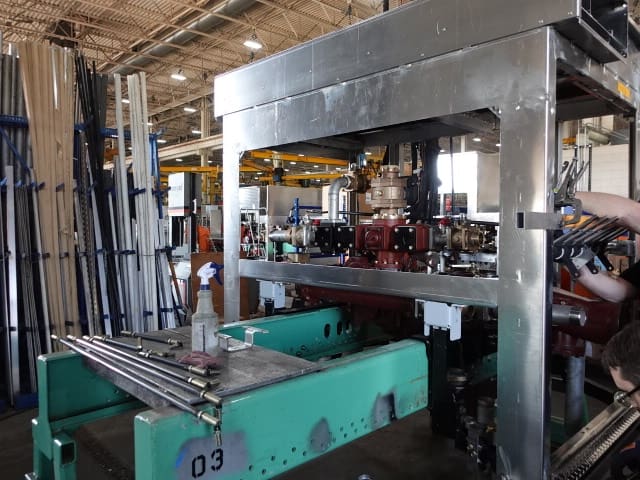

In this report, the cab continued through paint while the pump house structure was fabricated.

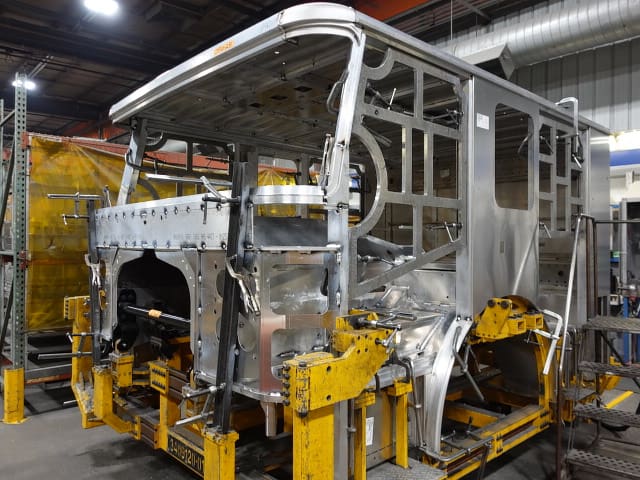

05-23-25

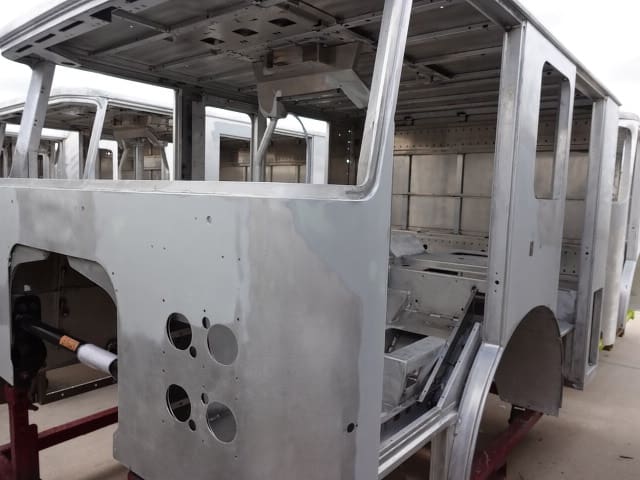

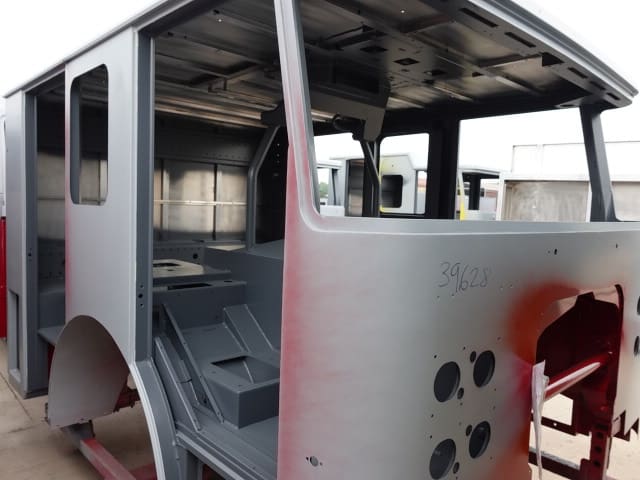

In this report, the cab completed fabrication and began the paint process with metal finishing.
05-16-25

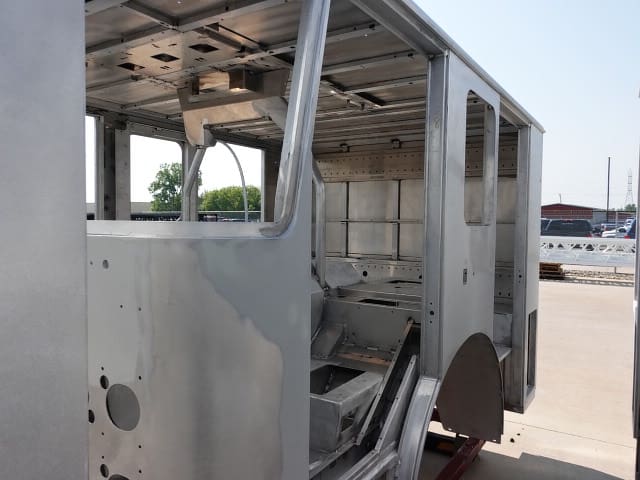

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
