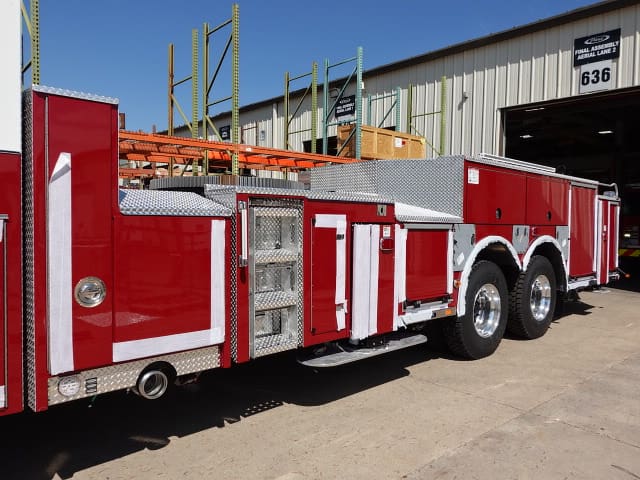

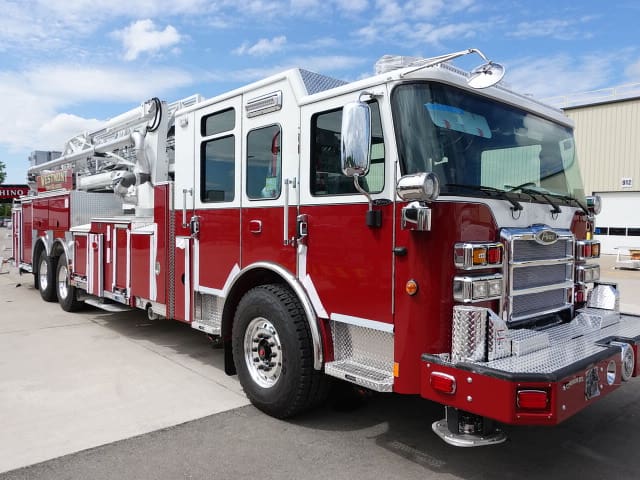

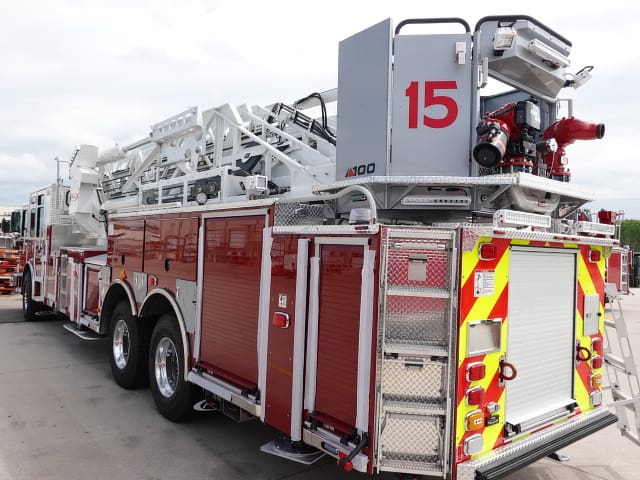

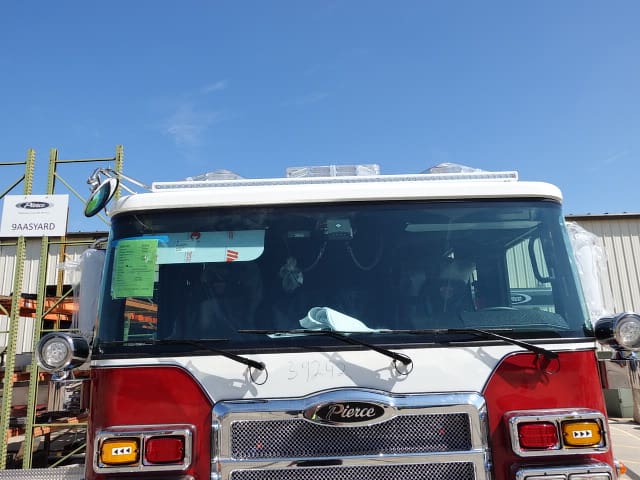

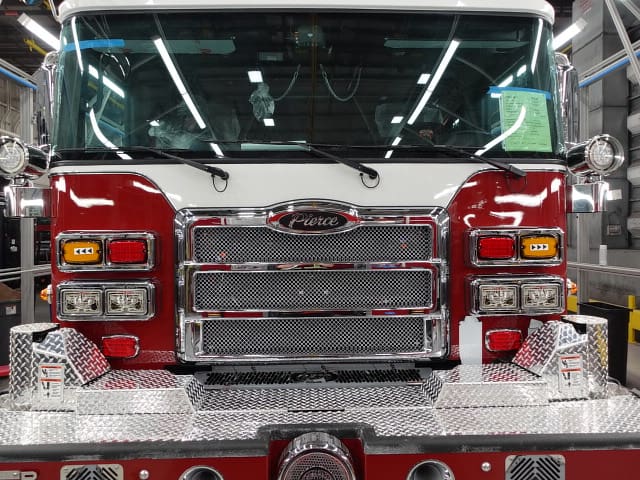

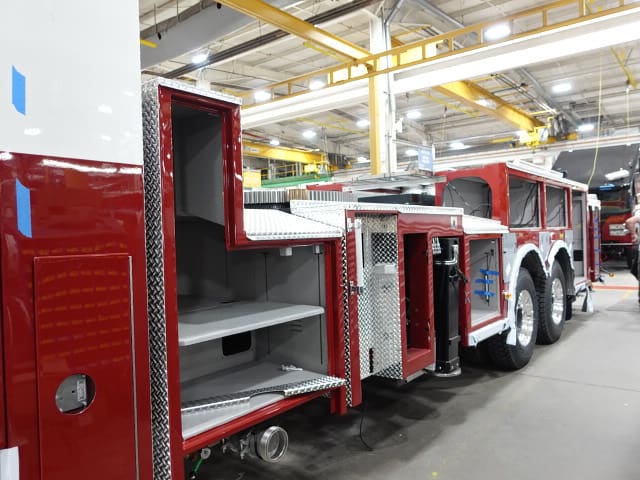

06-06-25

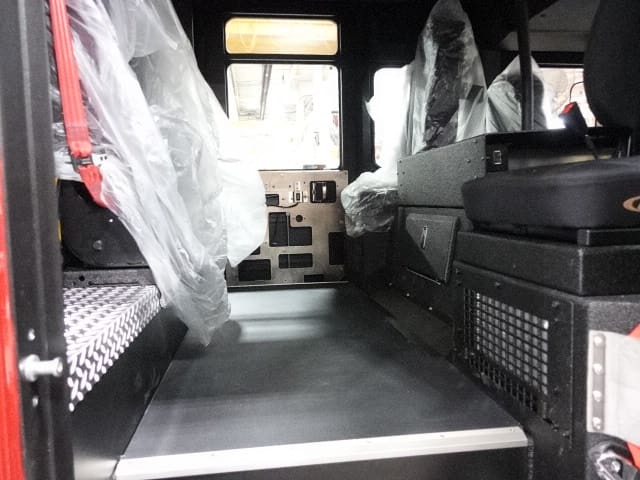

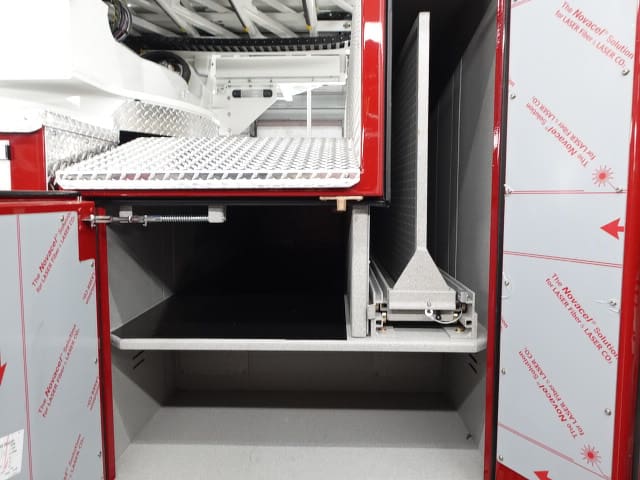

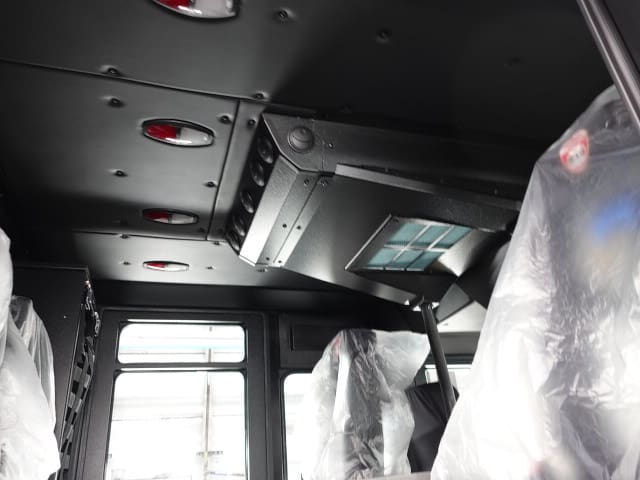

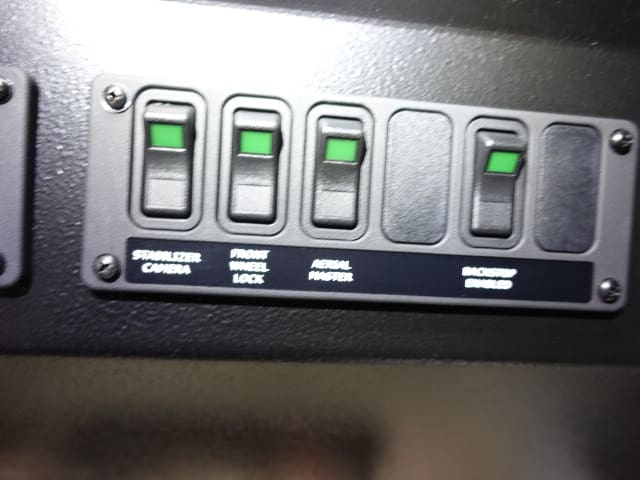

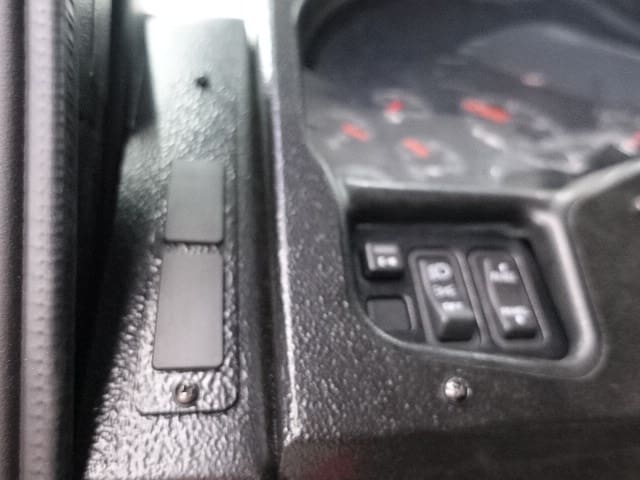

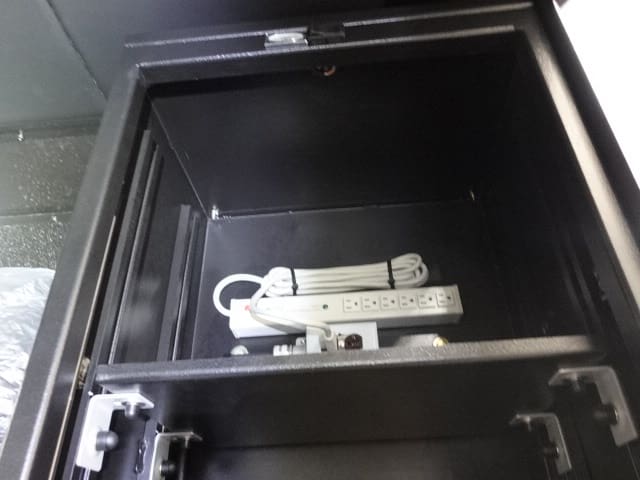

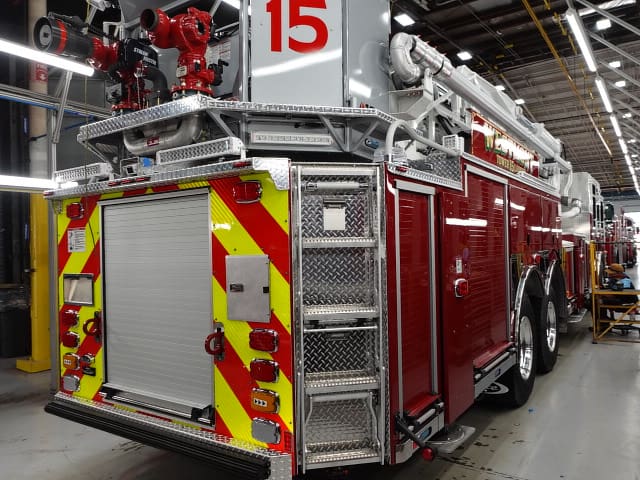

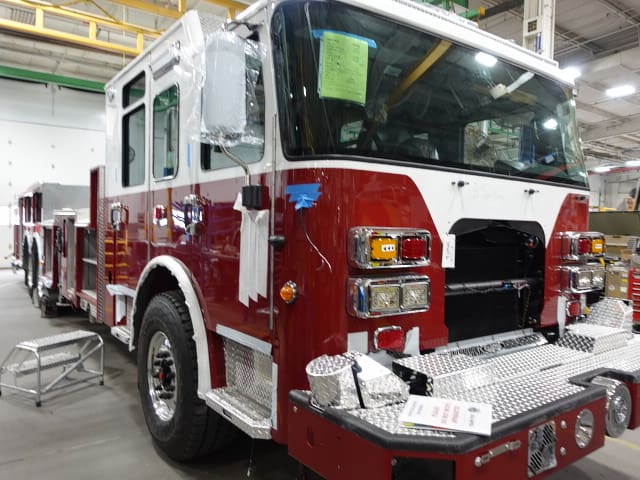

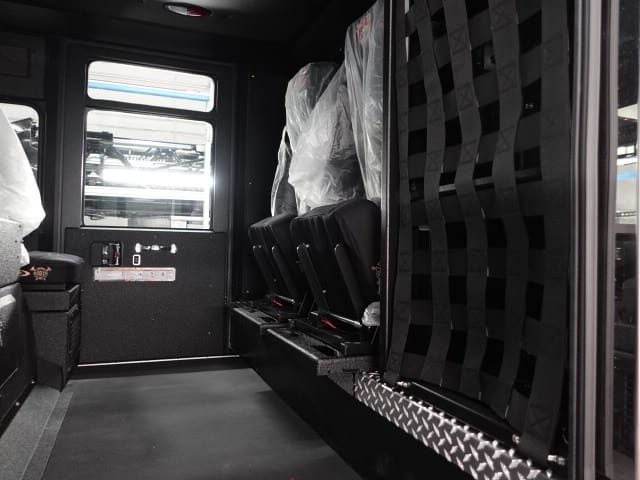

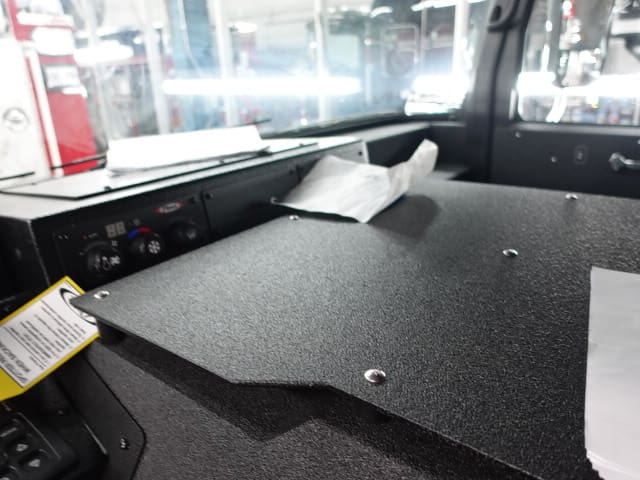

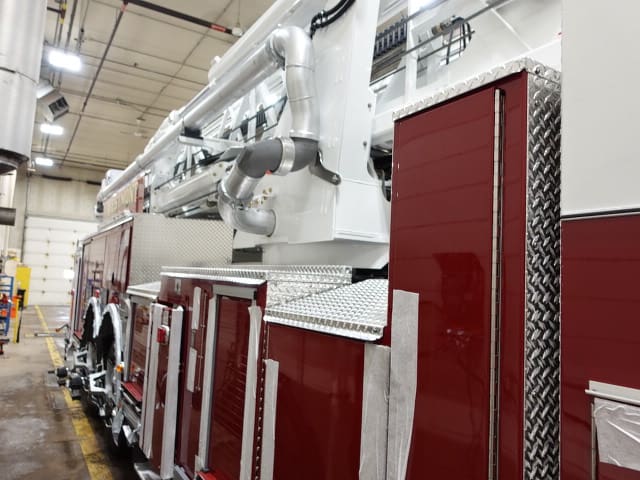

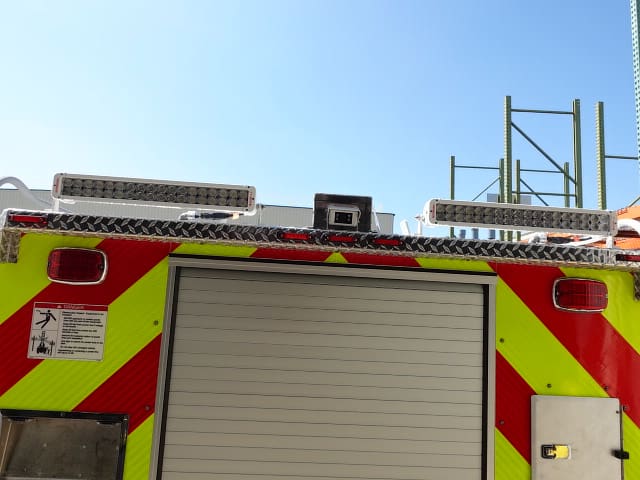

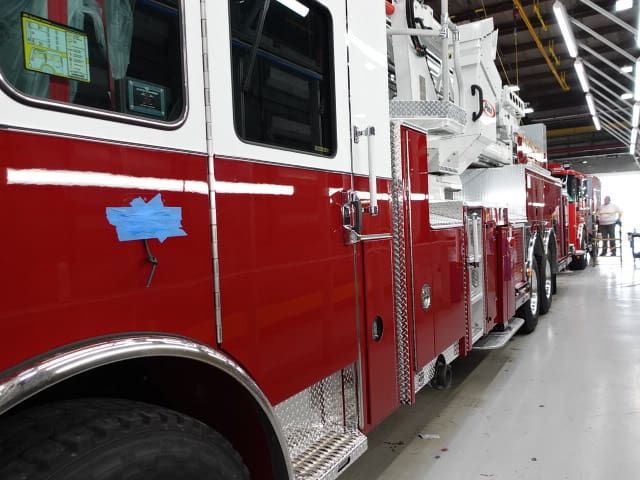

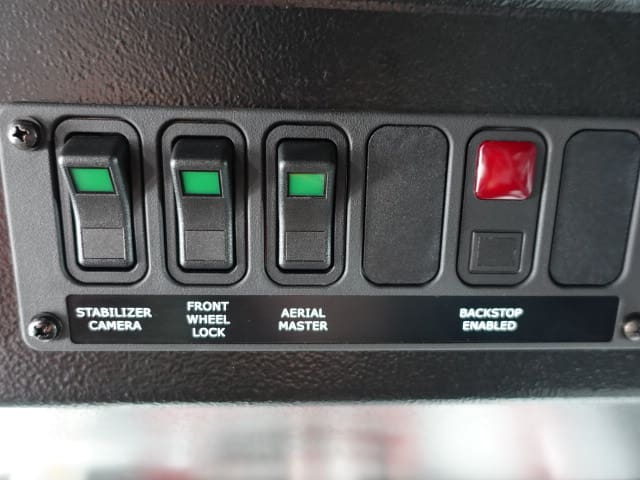

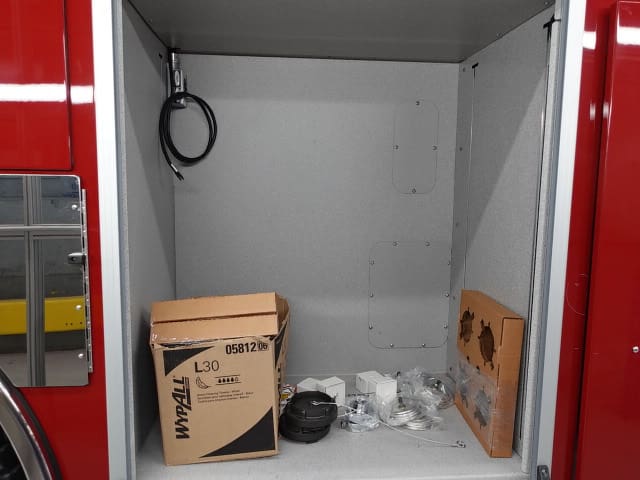

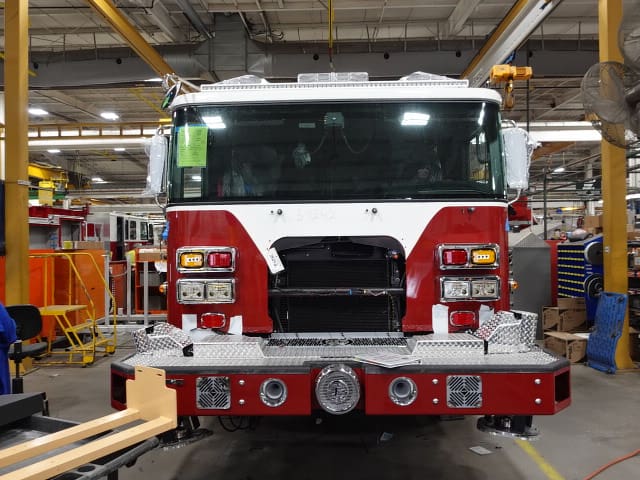

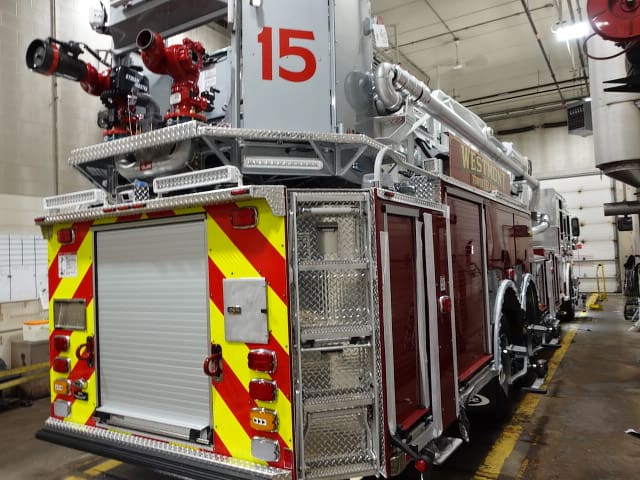

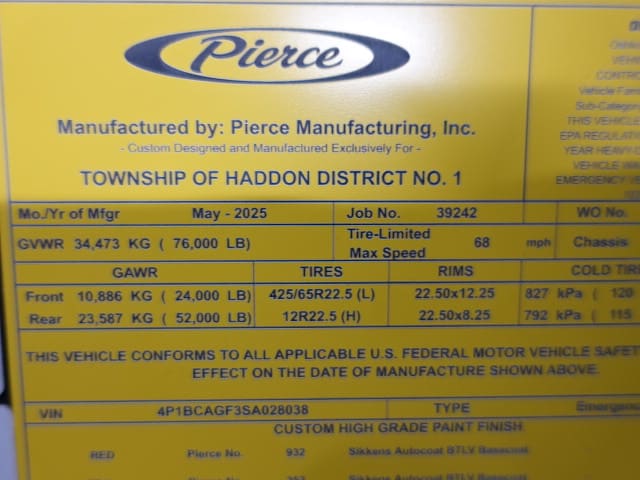

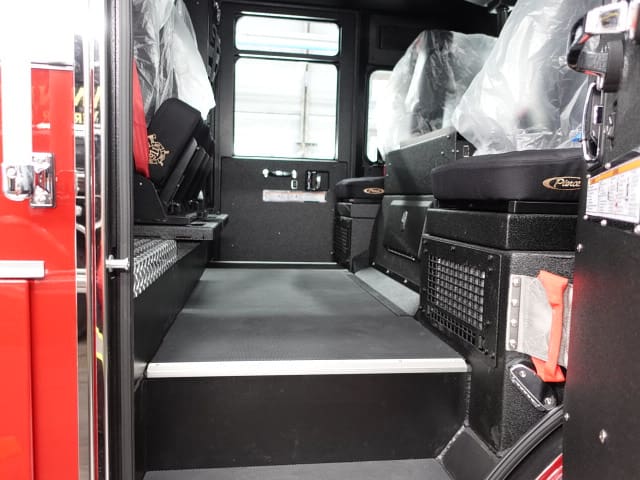

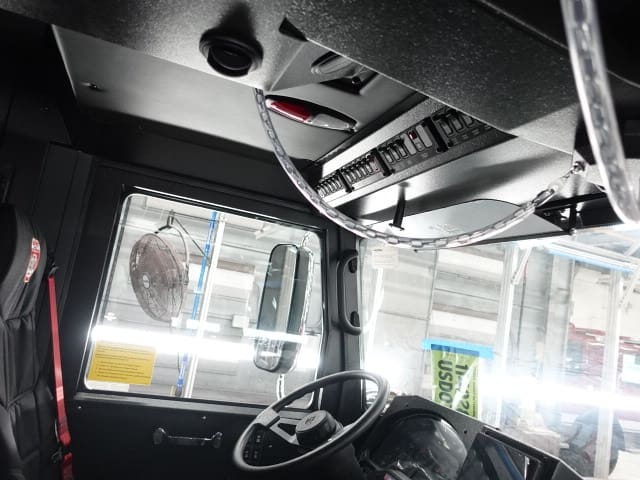

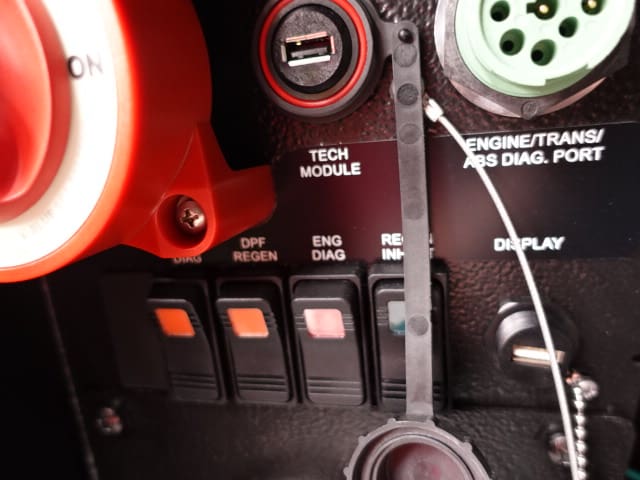

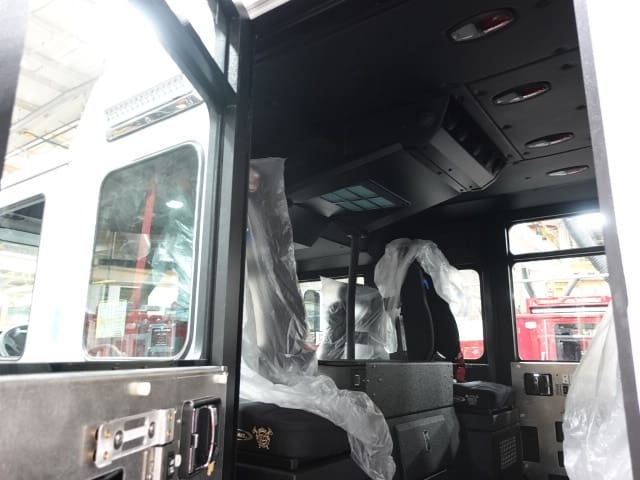

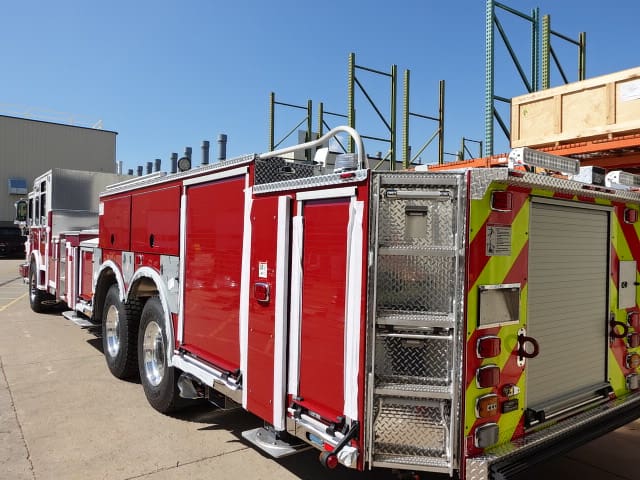

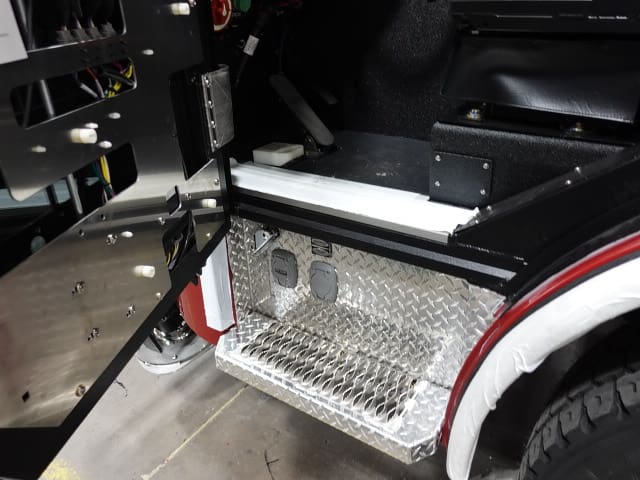

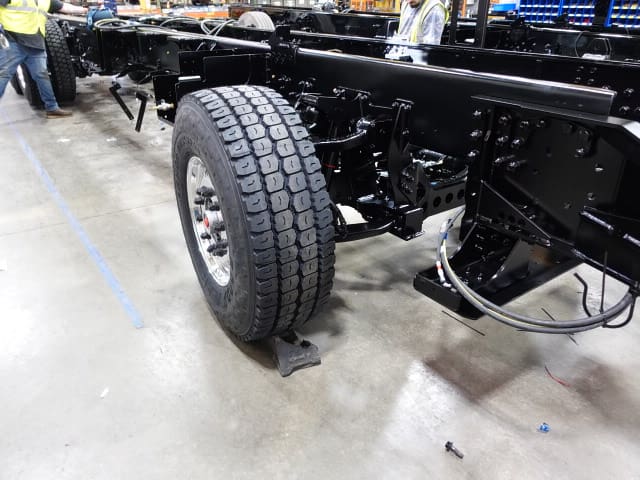

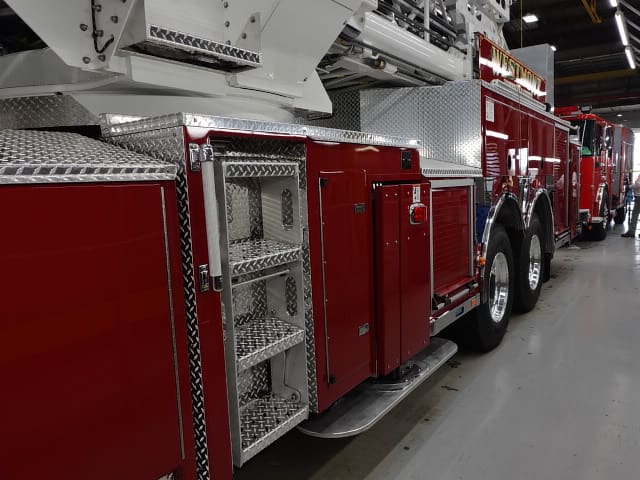

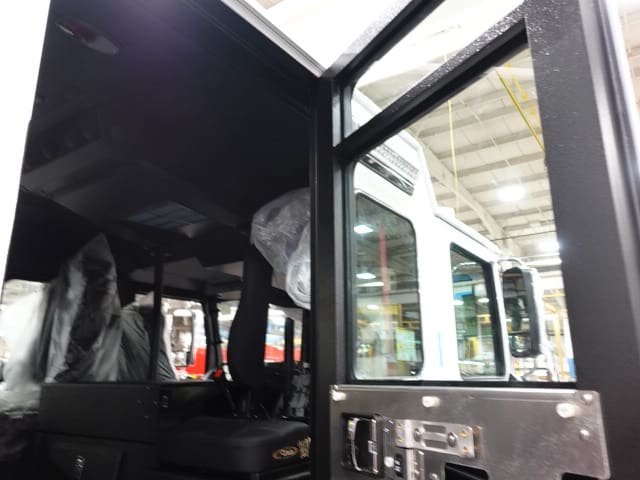

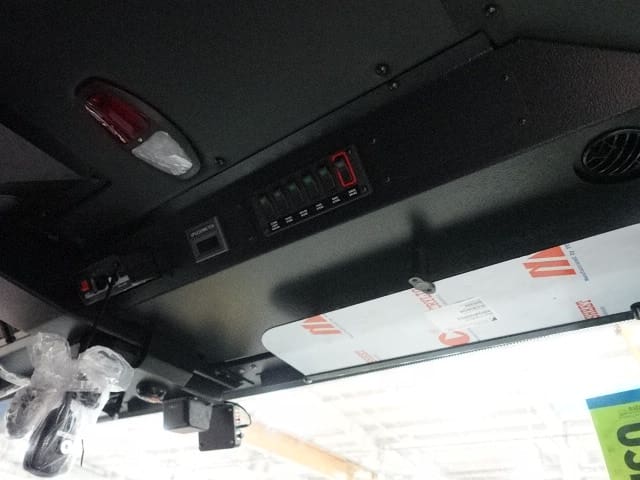

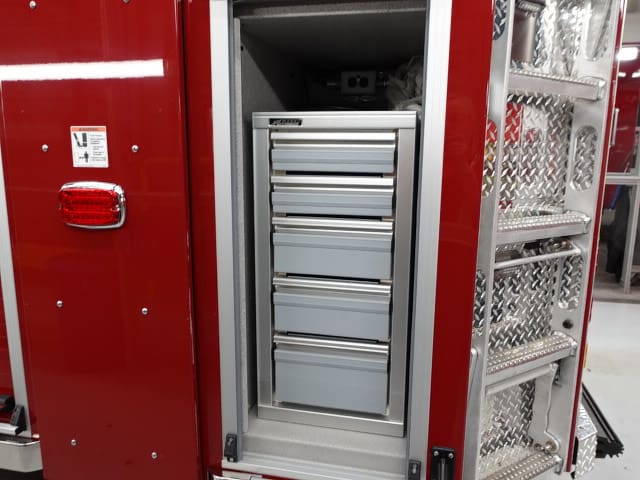

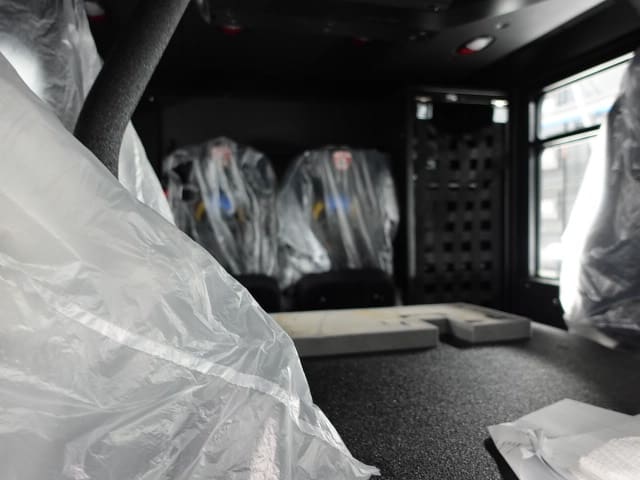

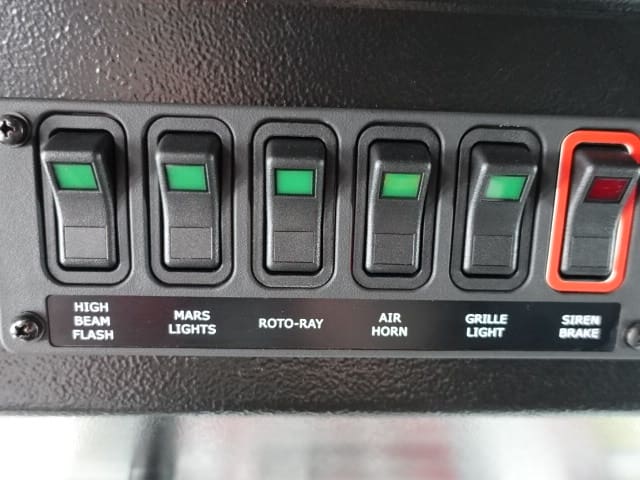

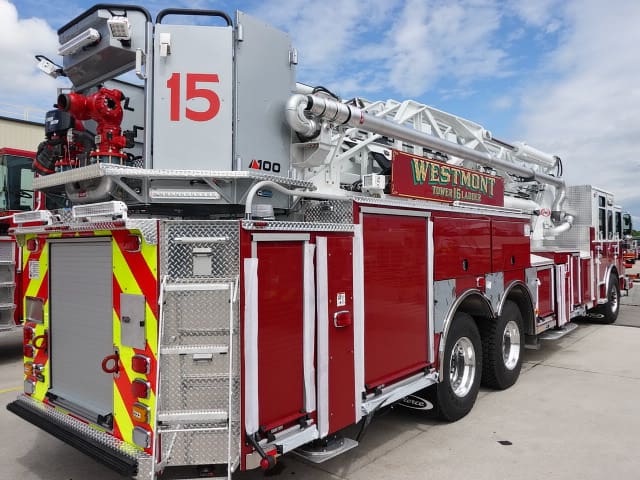

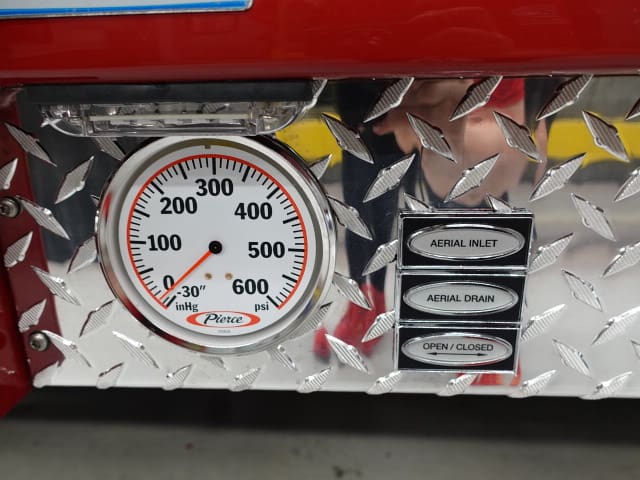

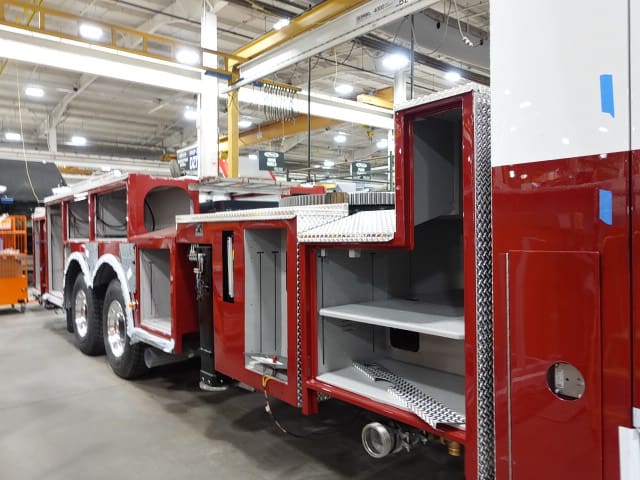

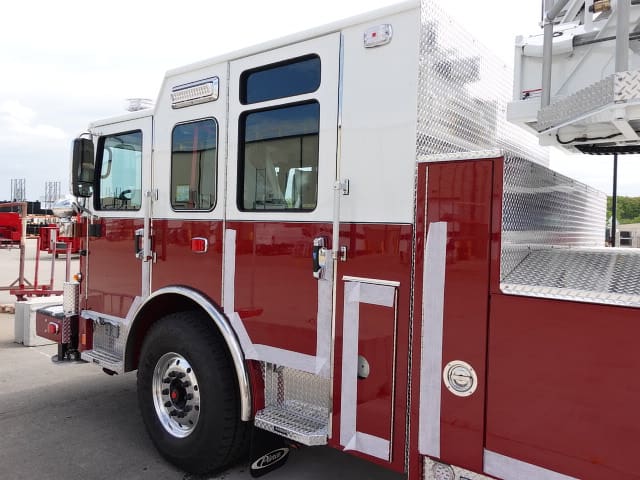

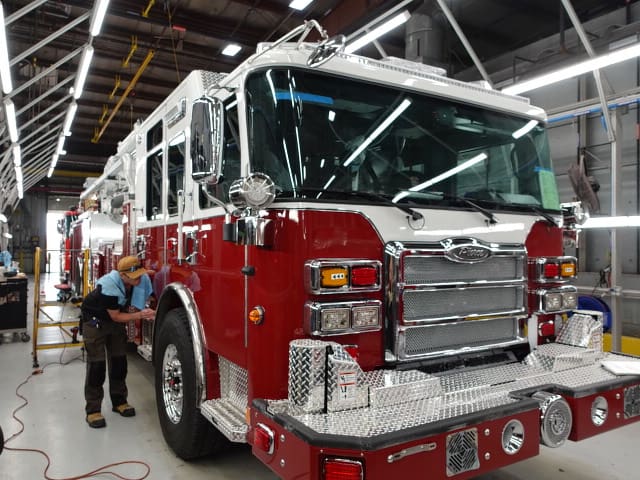

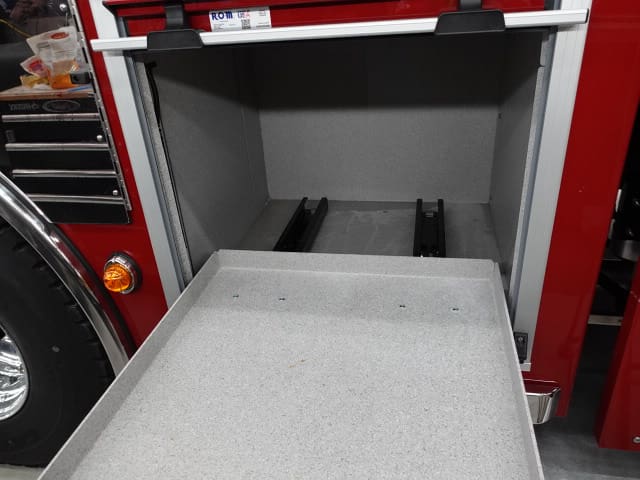

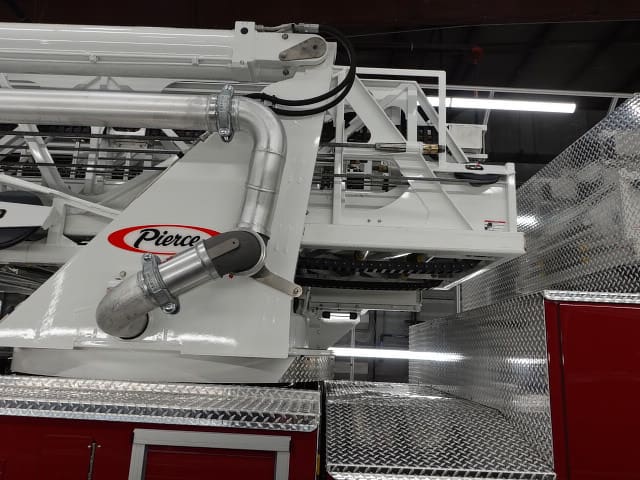

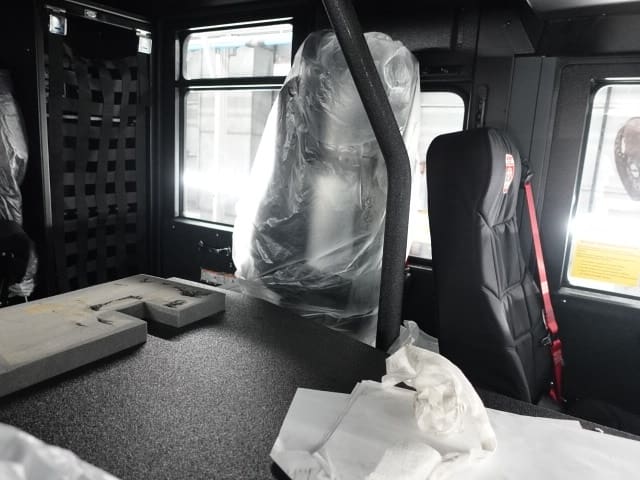

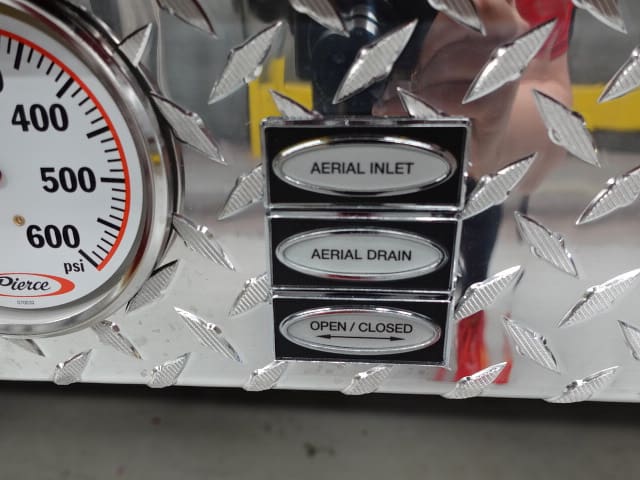

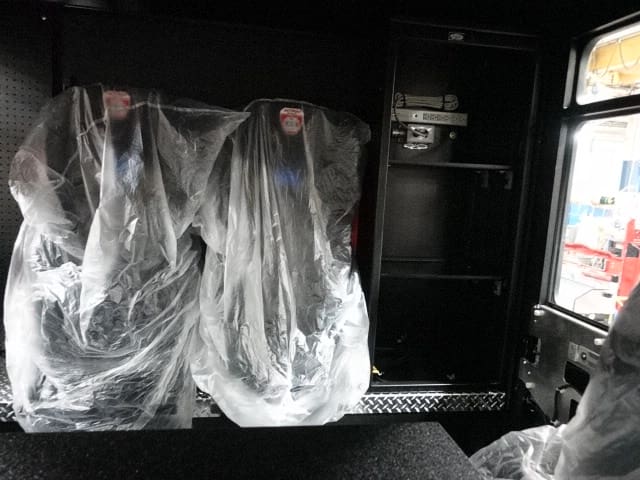

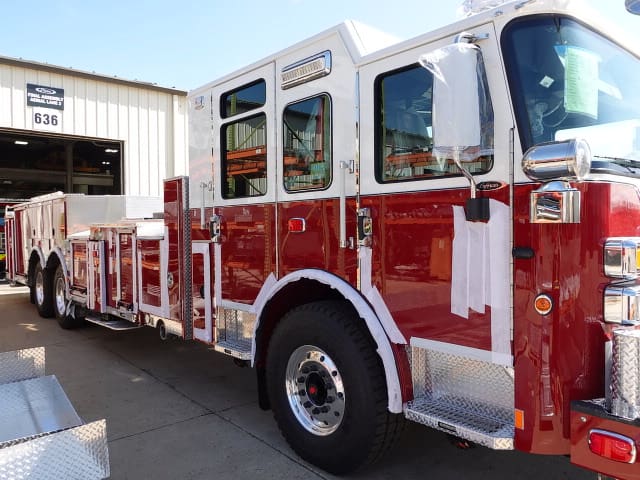

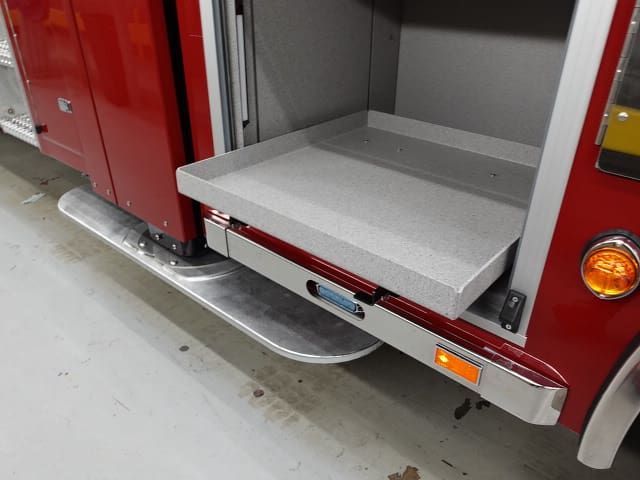

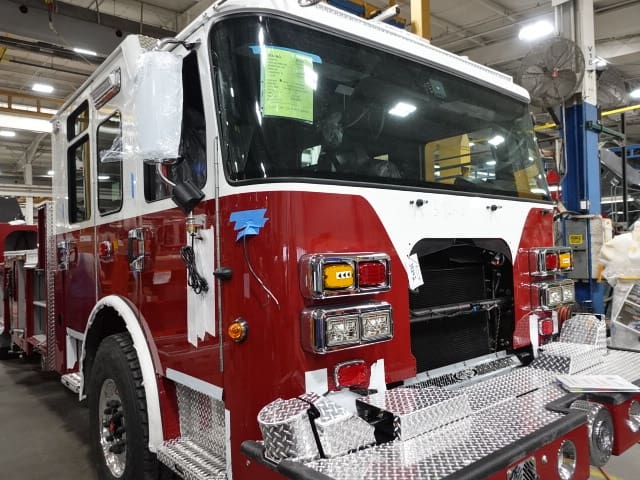

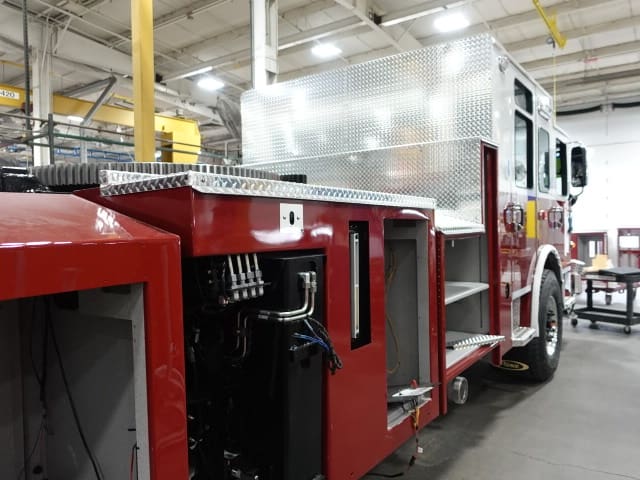

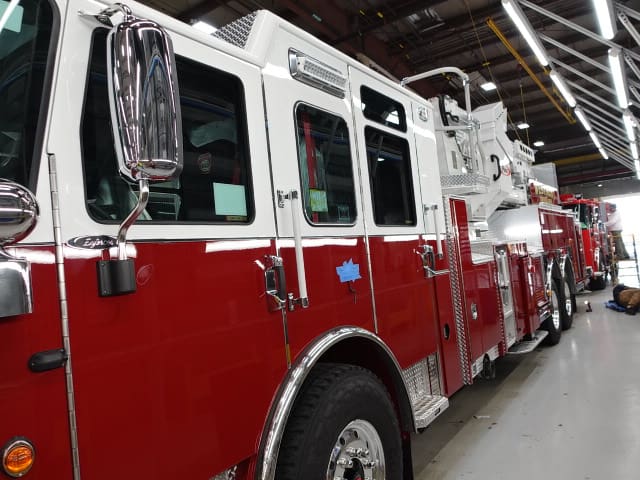

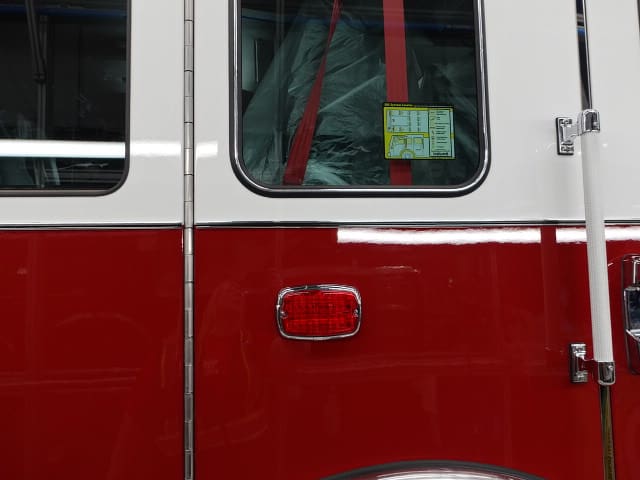

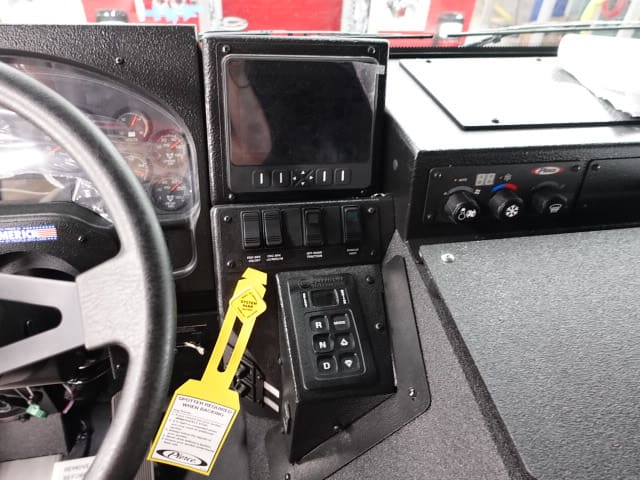

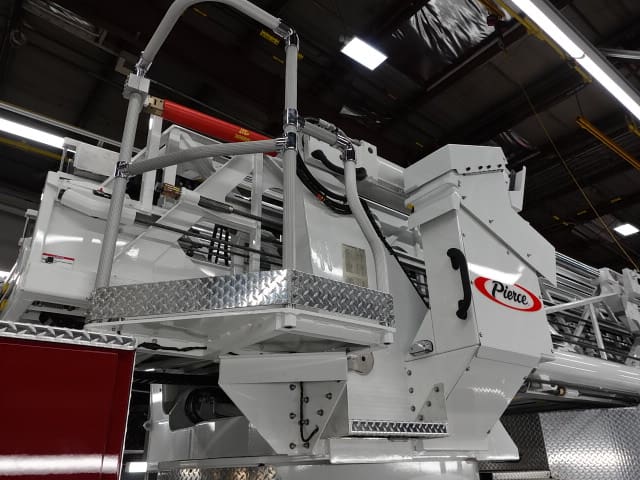

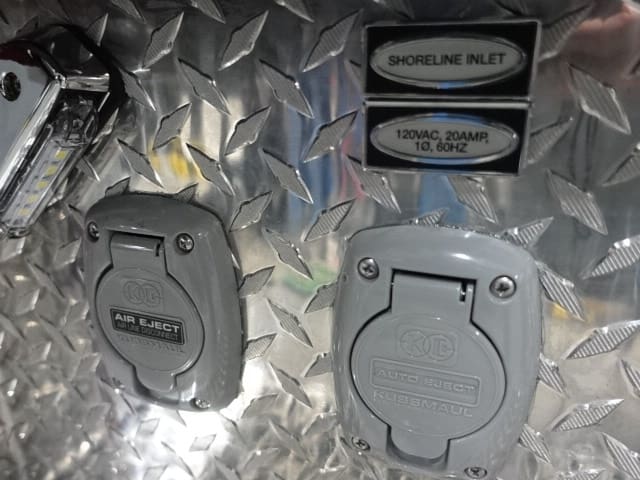

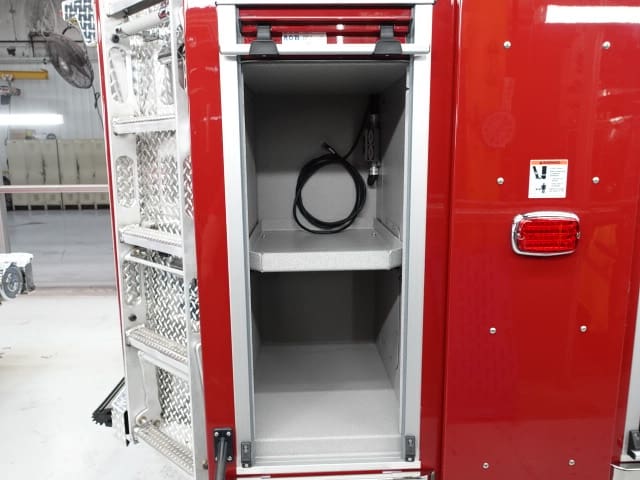

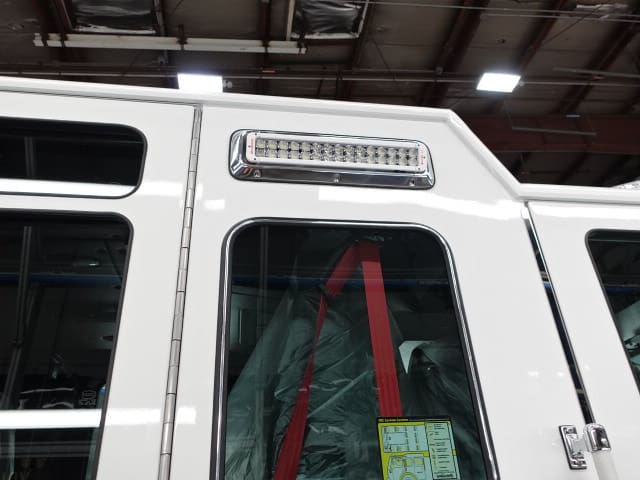

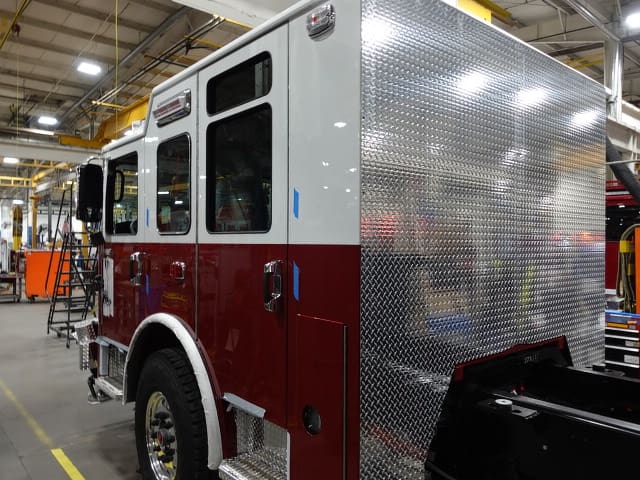

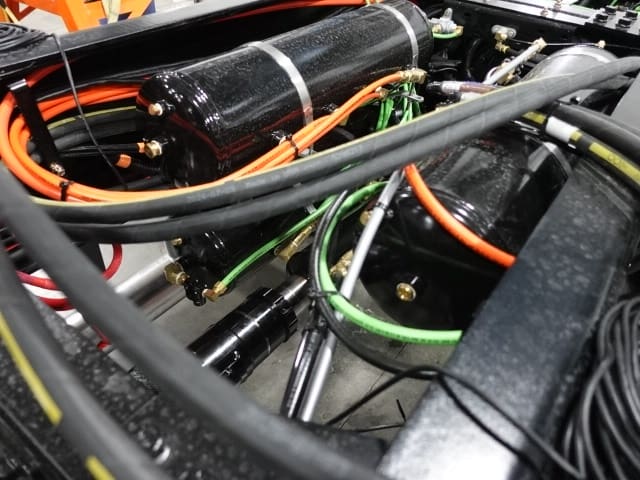

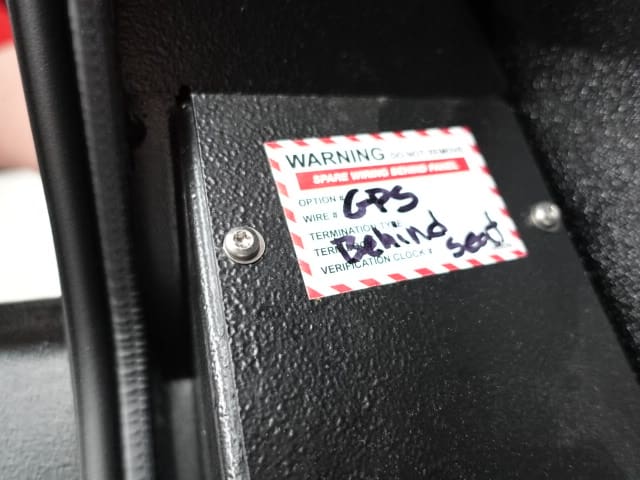

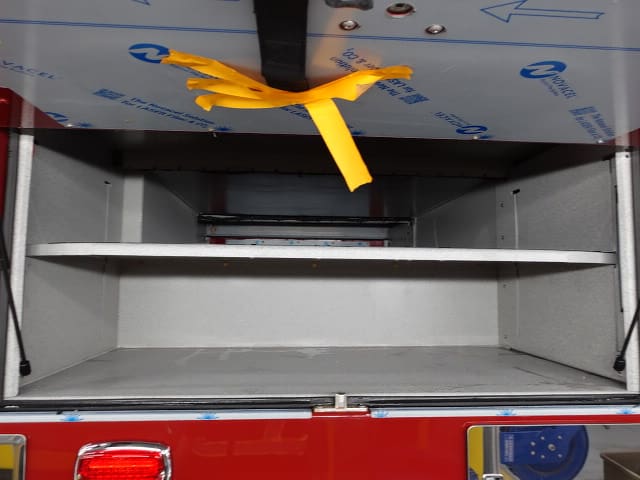

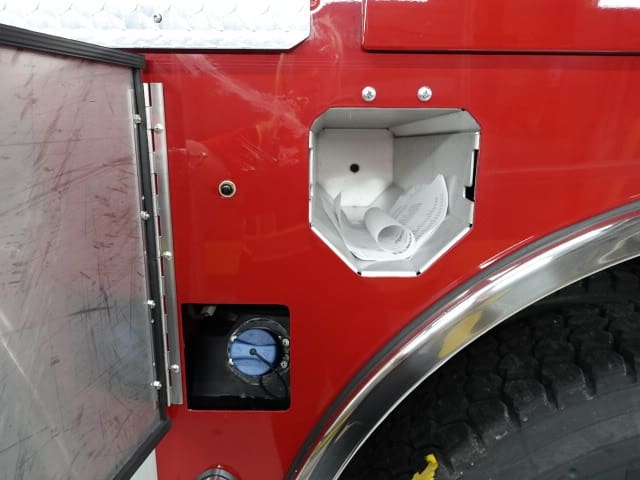

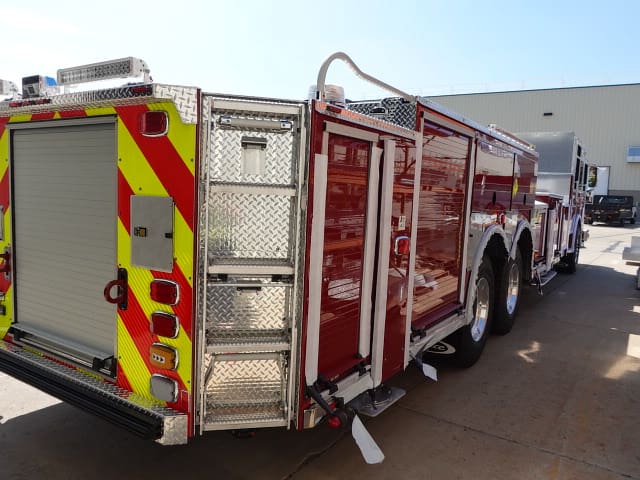

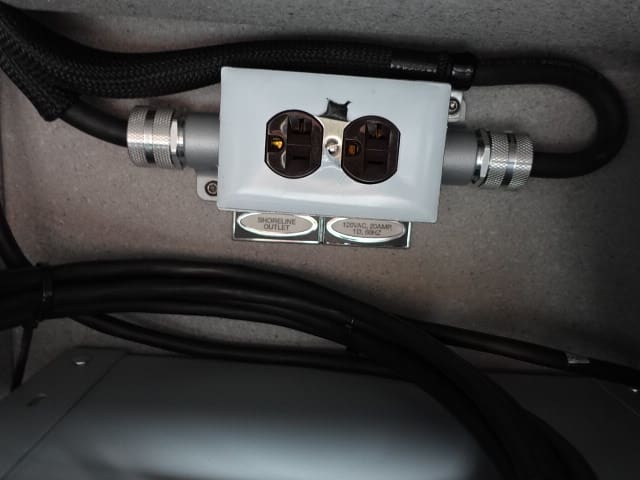

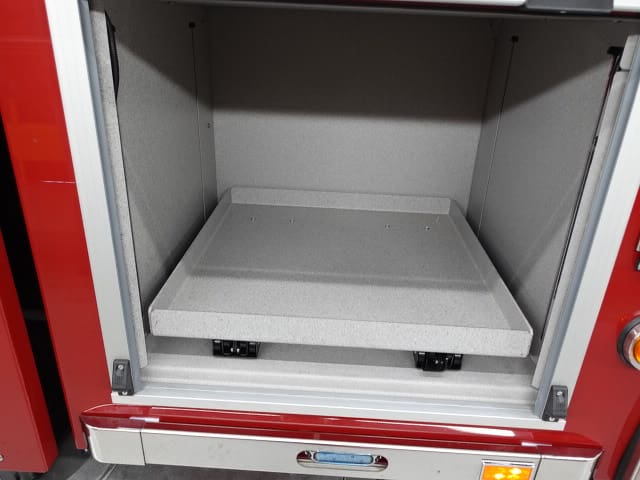

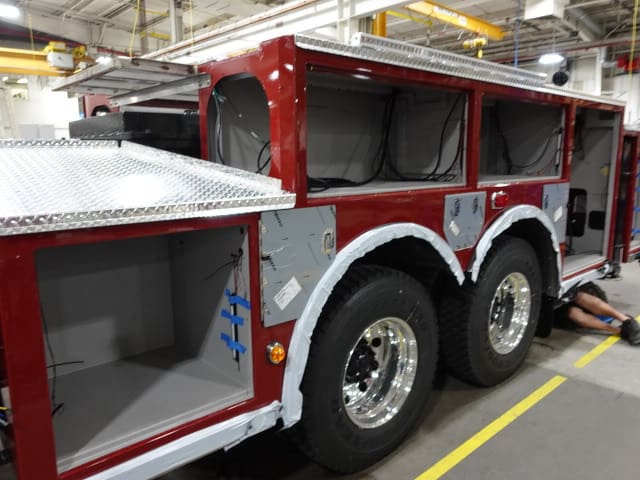

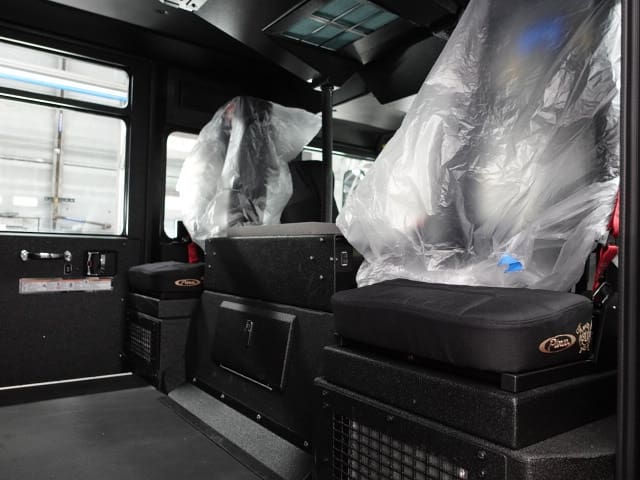

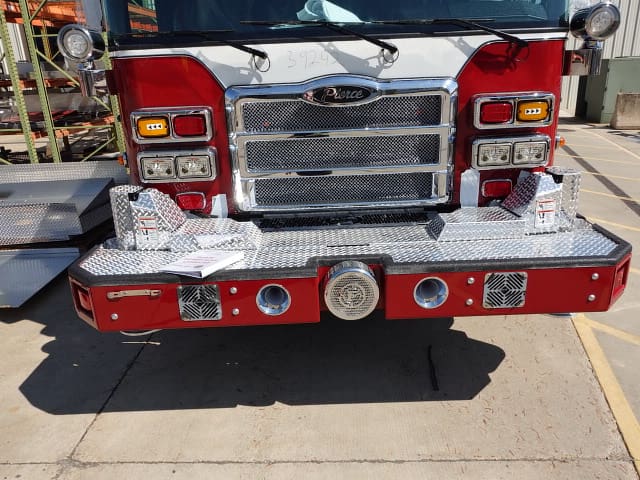

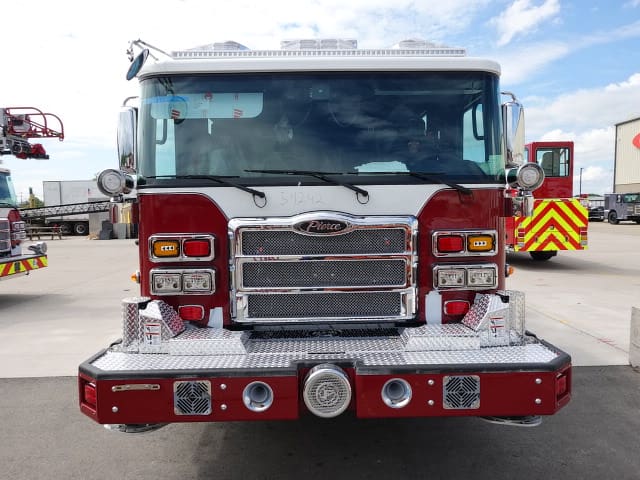

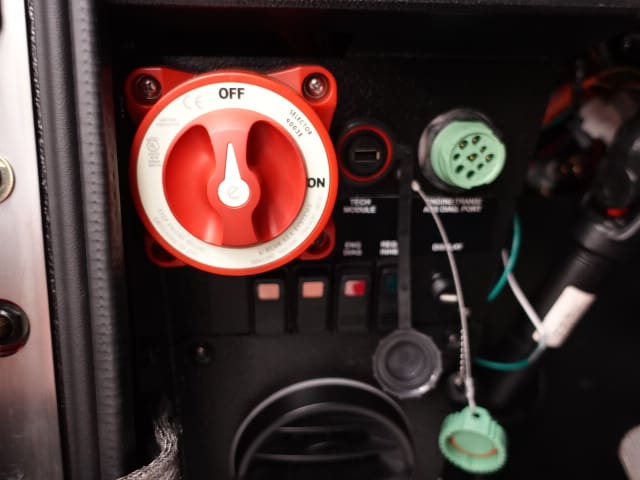

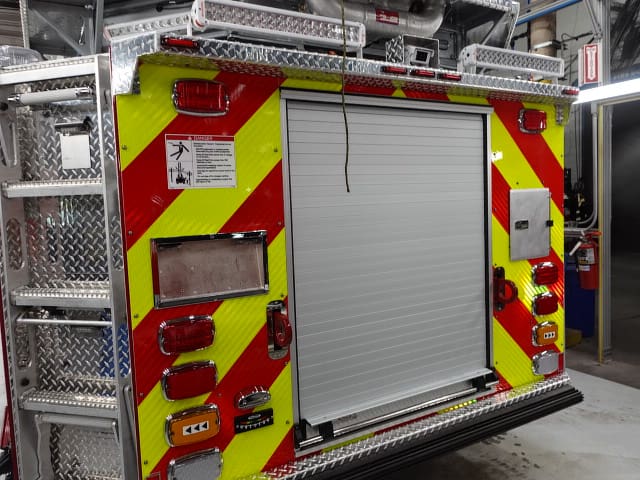

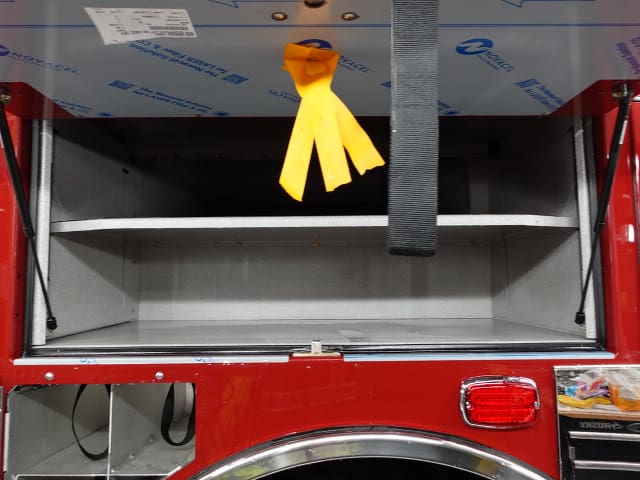

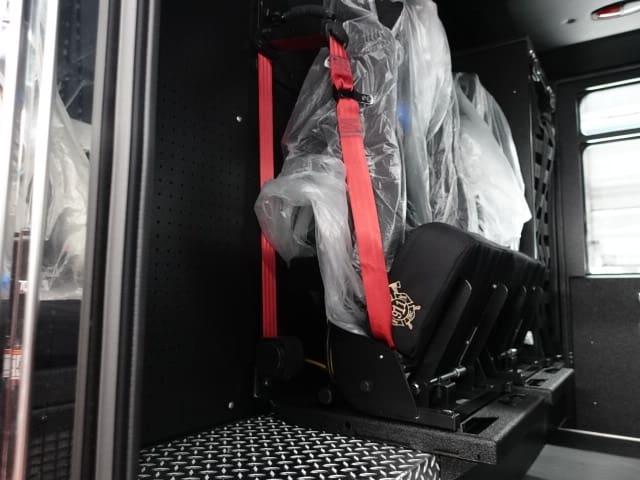

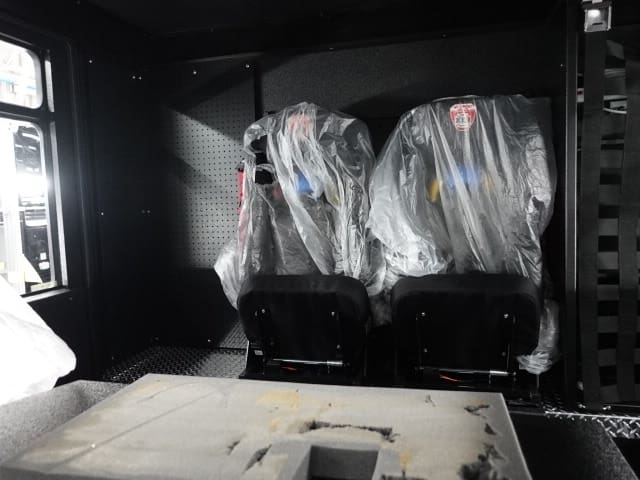

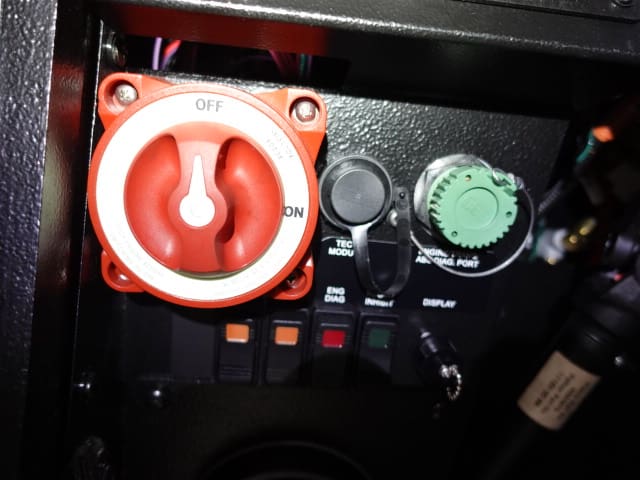

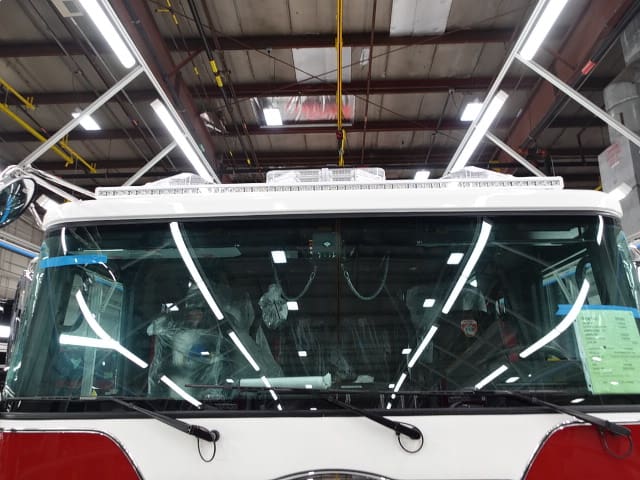

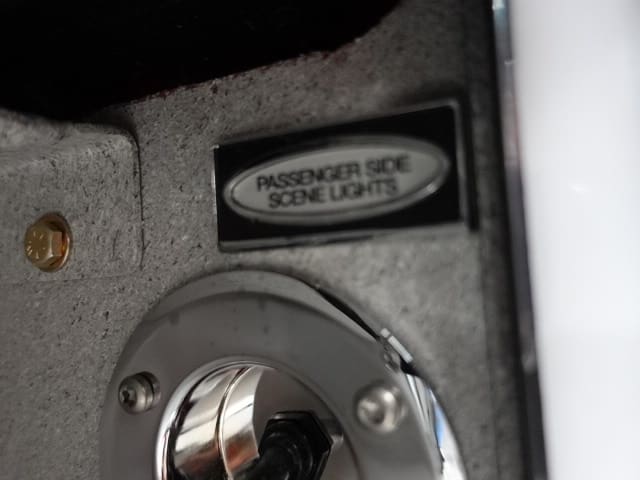

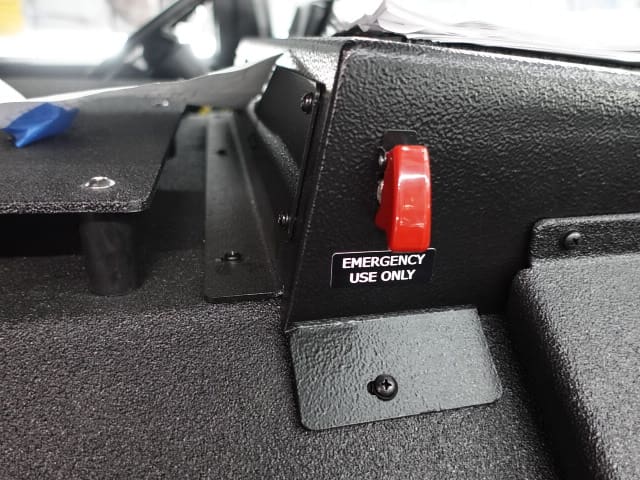

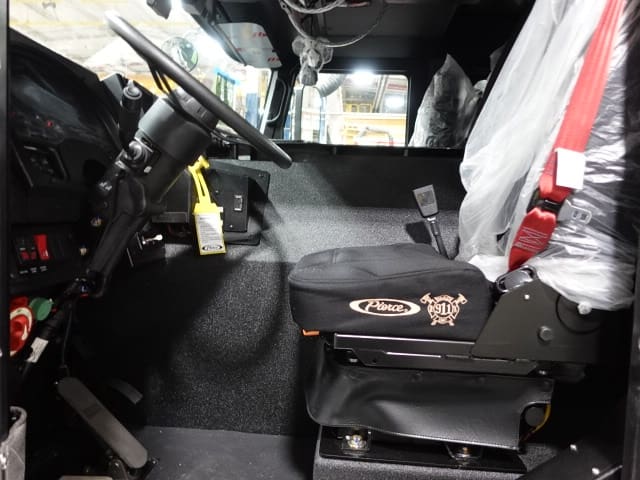

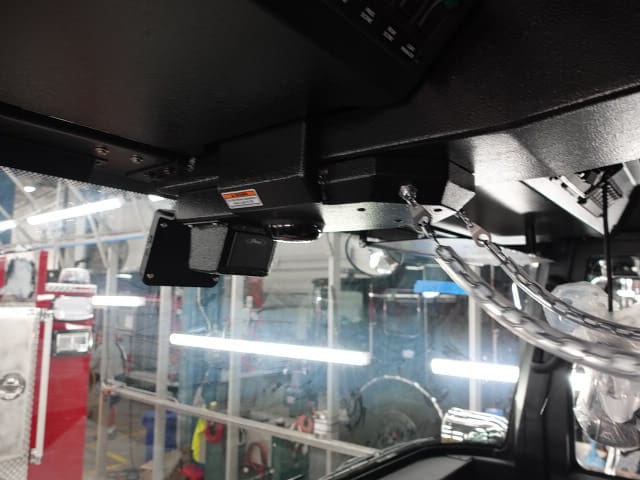

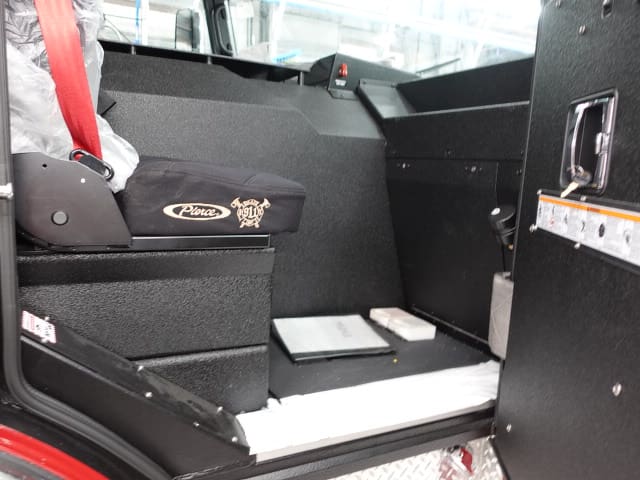

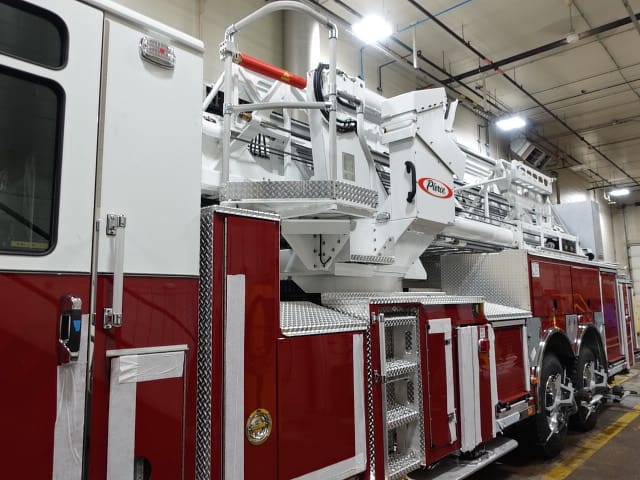

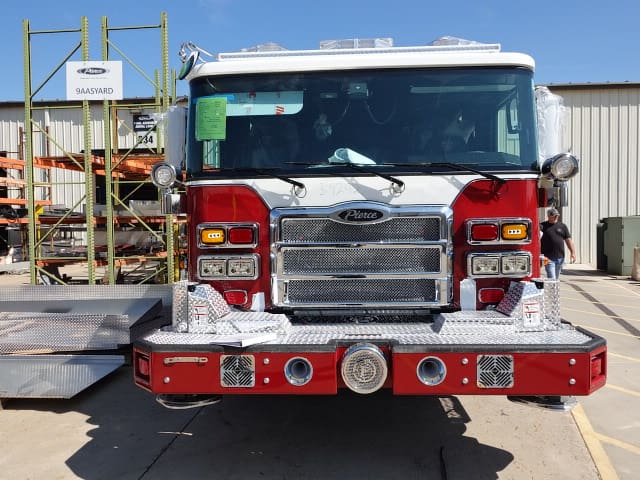

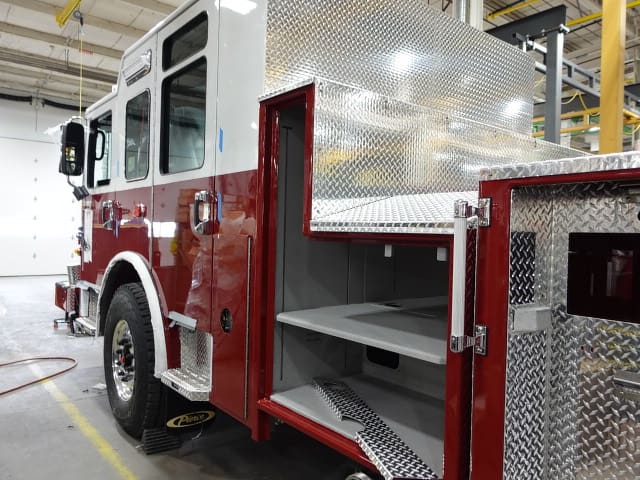

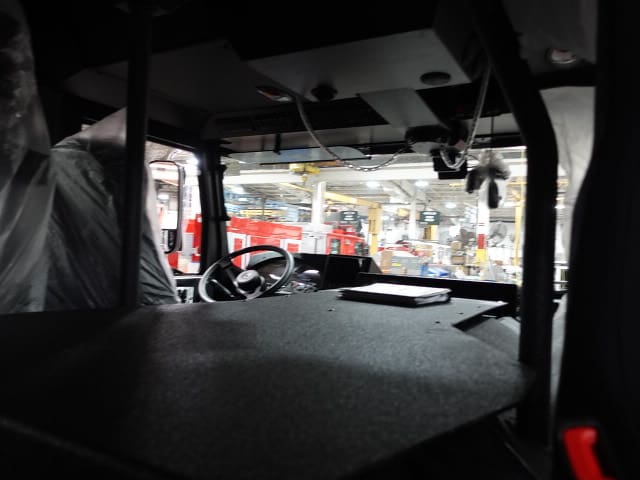

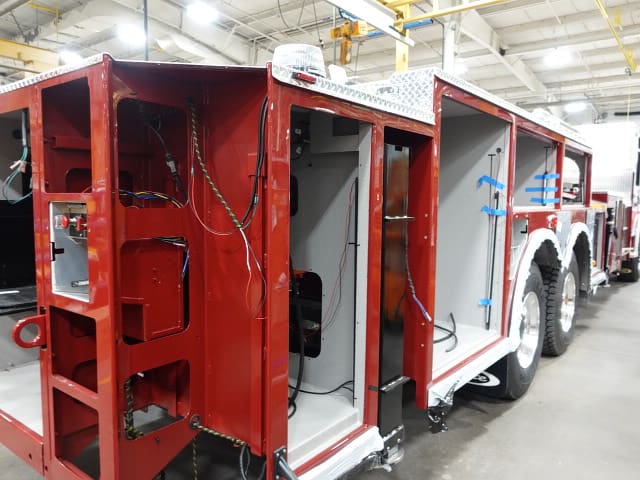

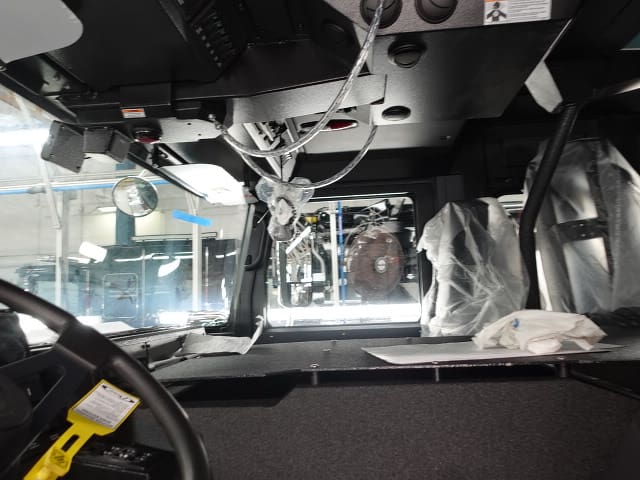

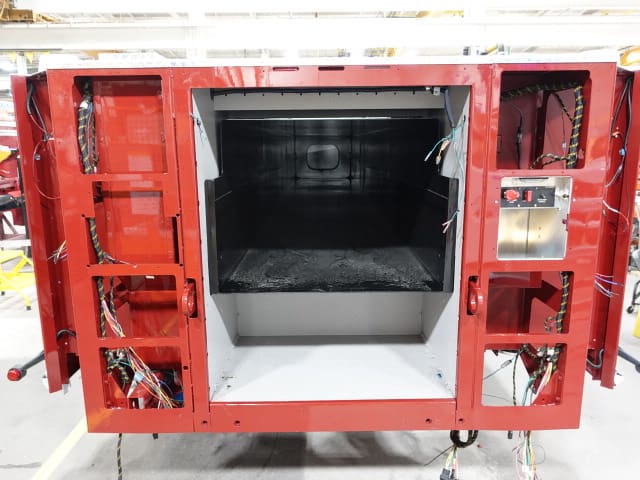

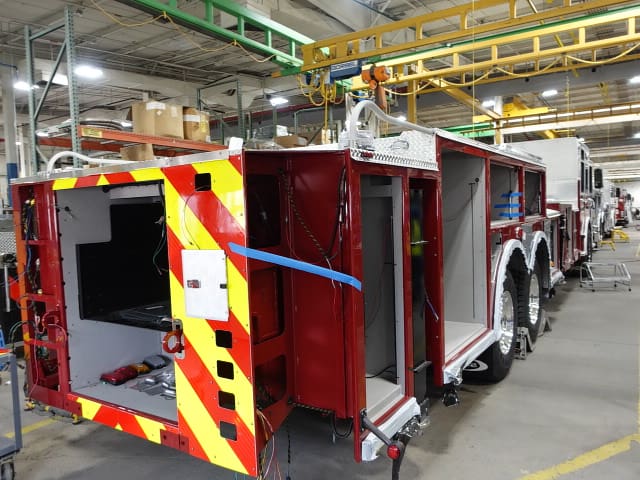

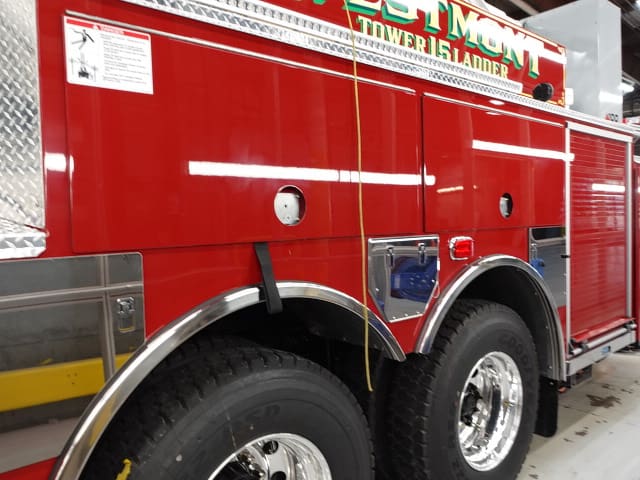

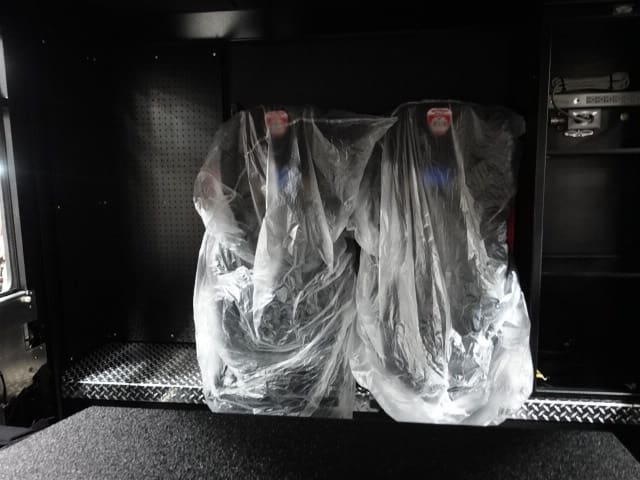

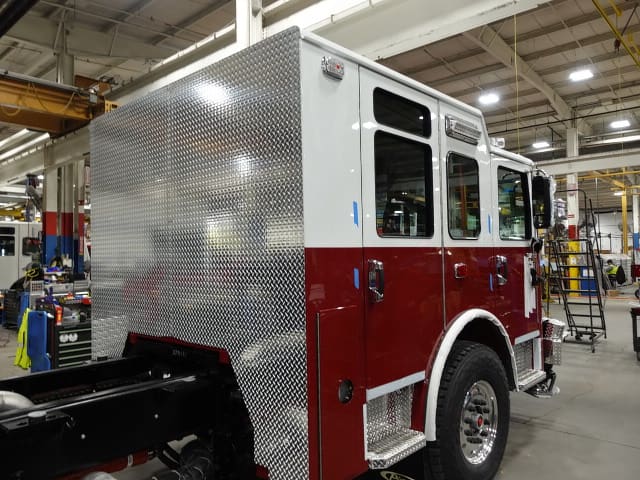

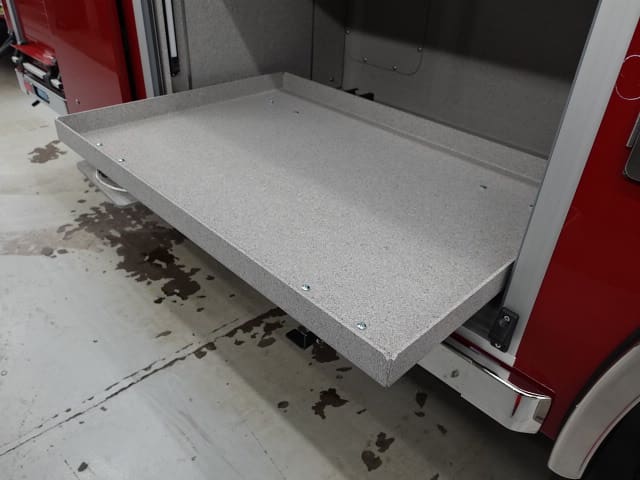

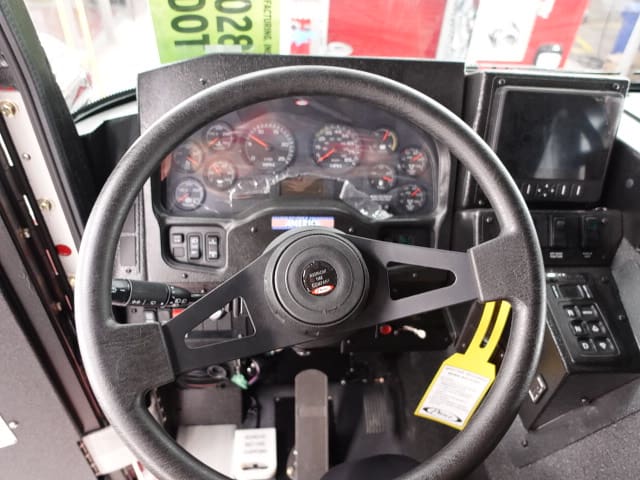

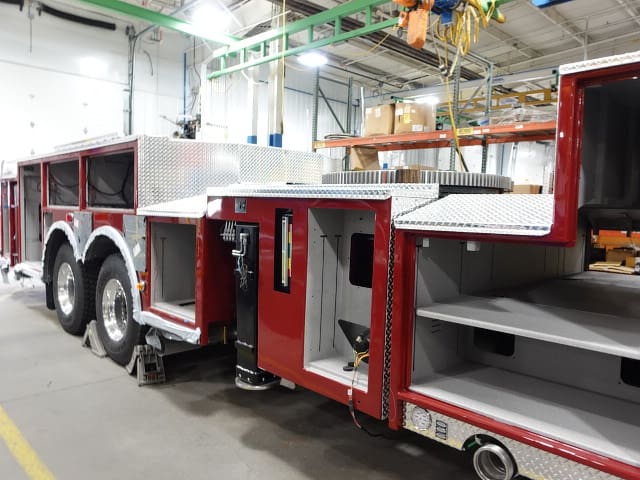

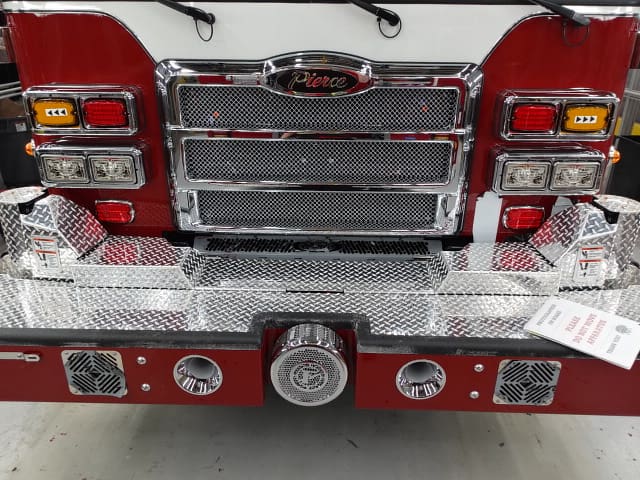

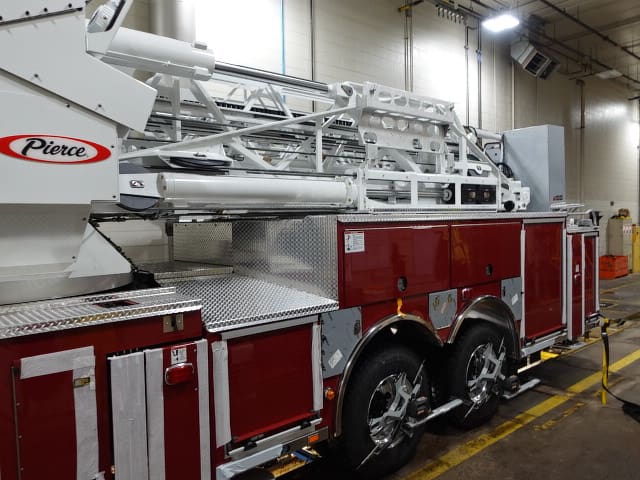

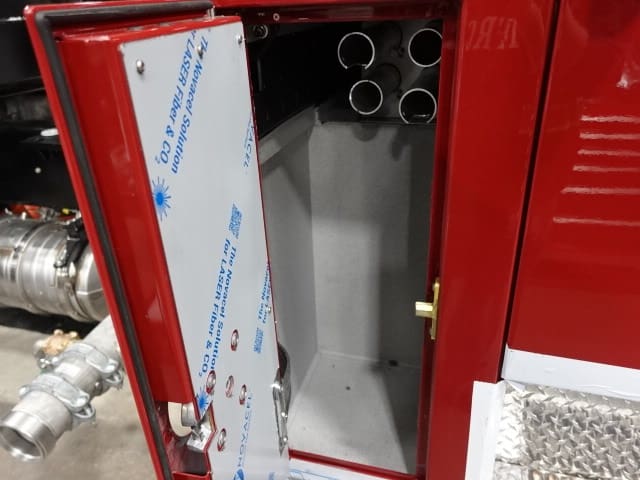

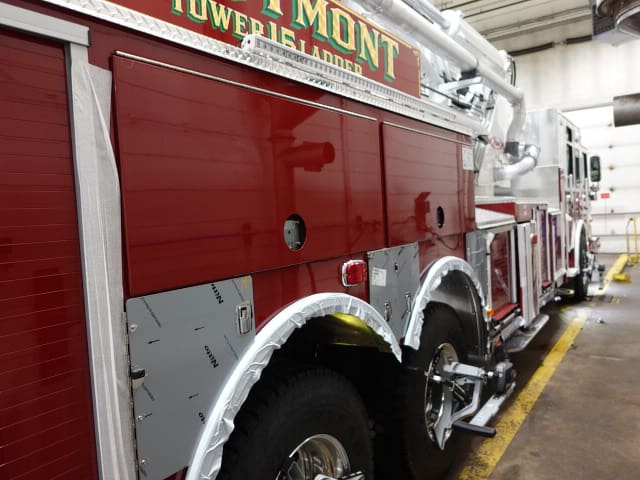

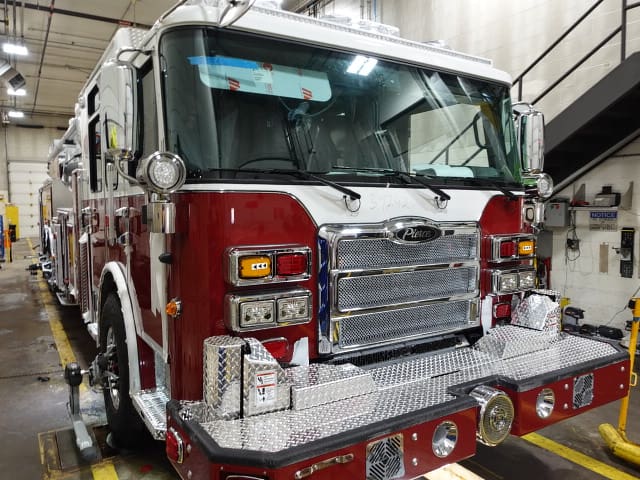

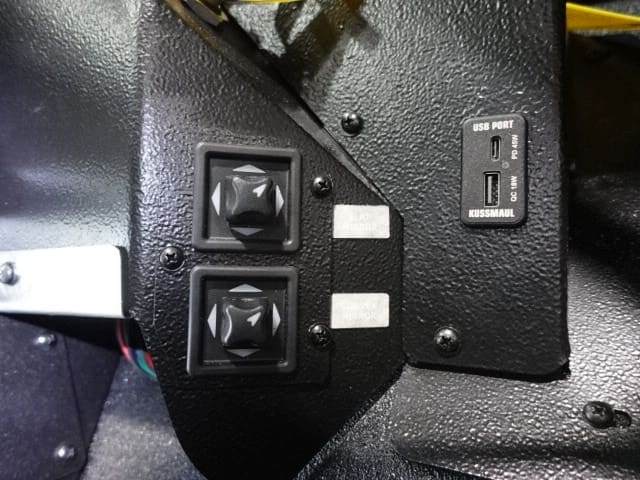

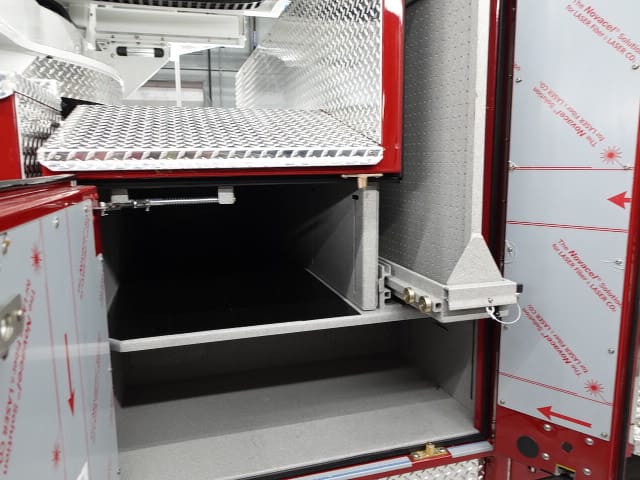

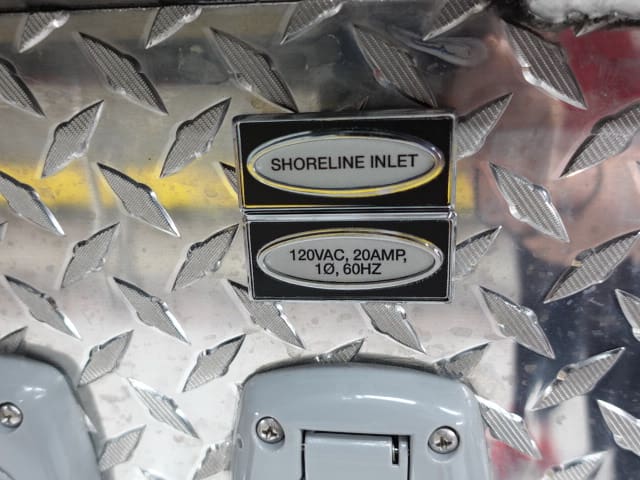

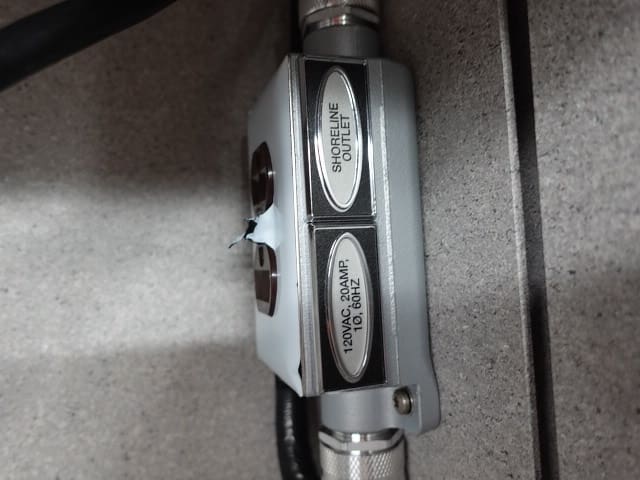

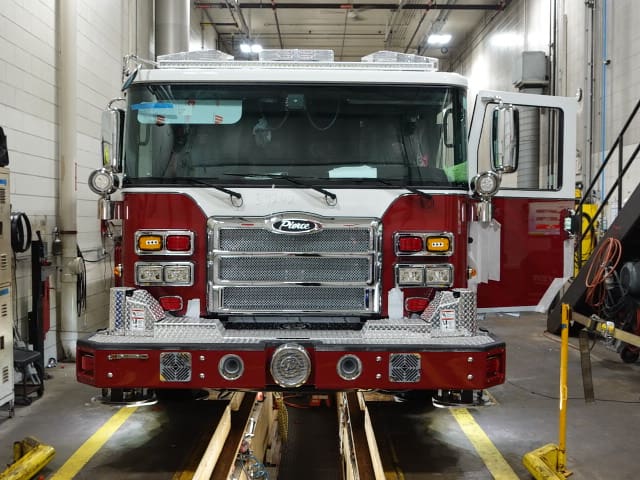

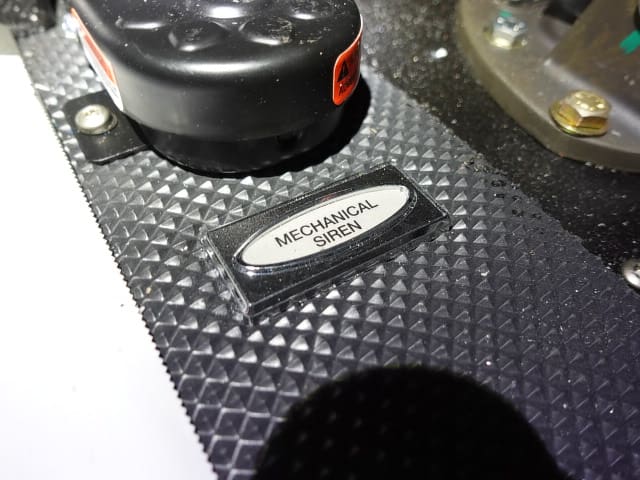

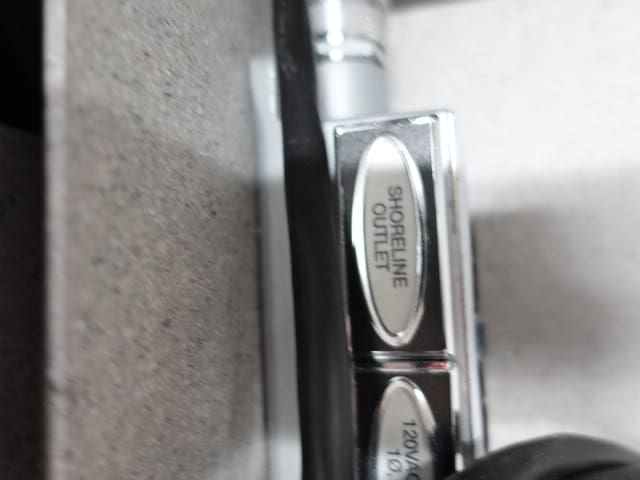

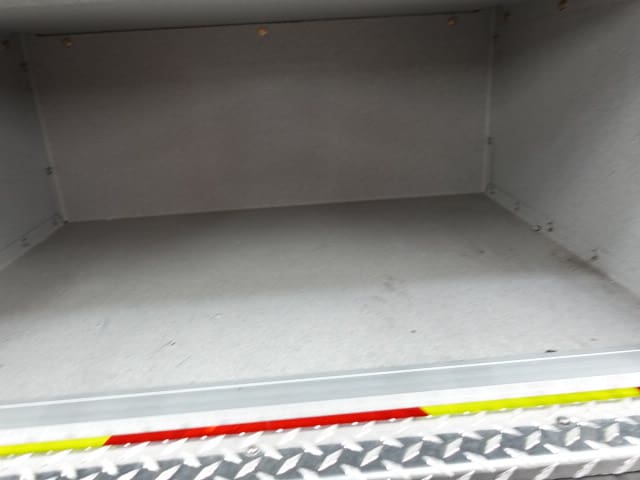

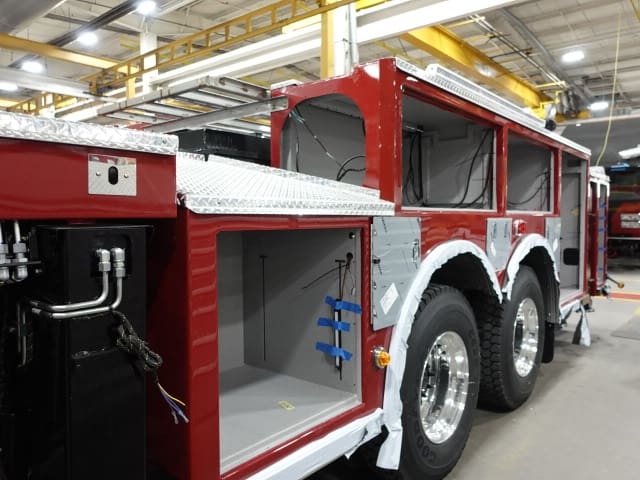

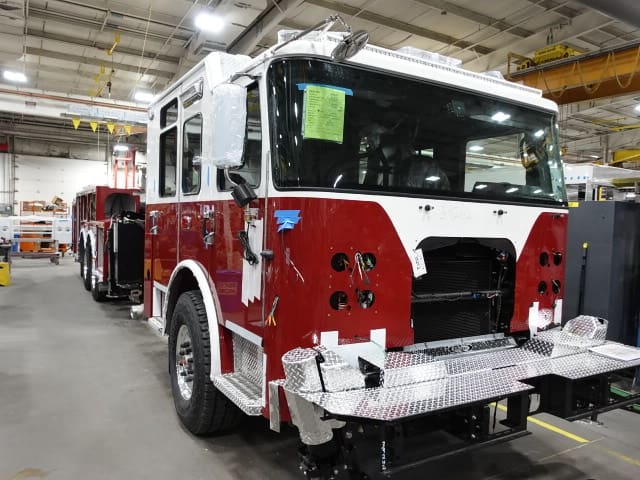

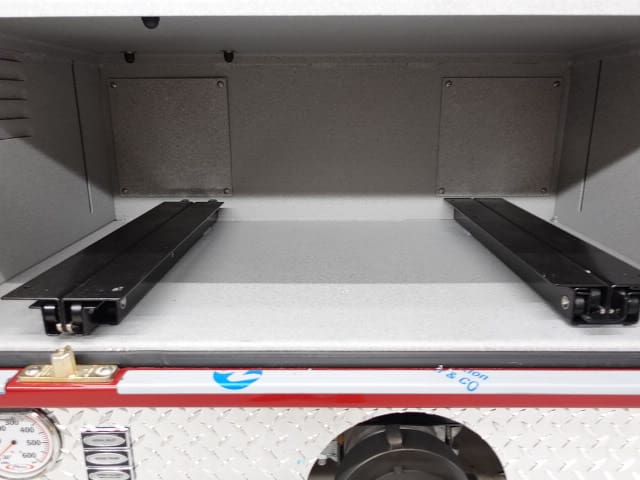

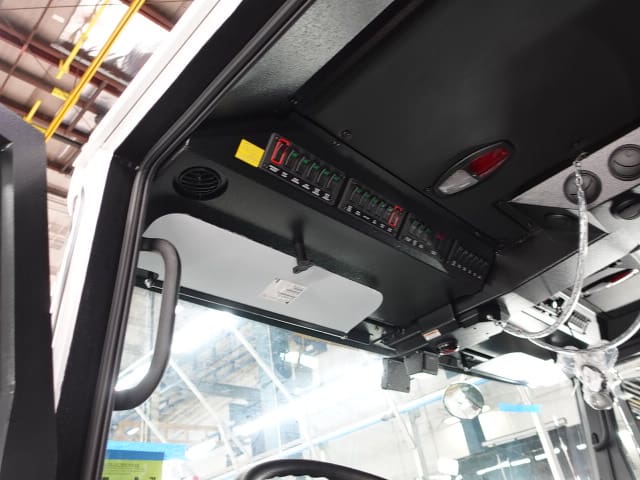

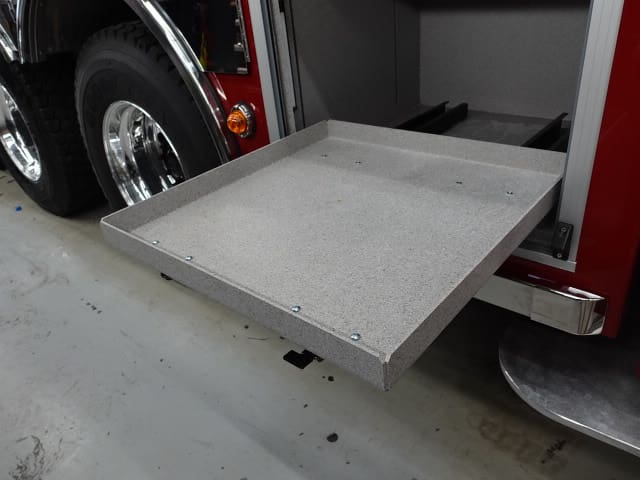

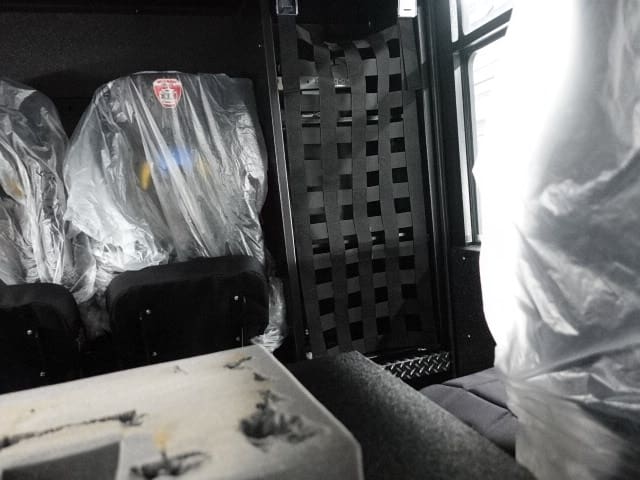

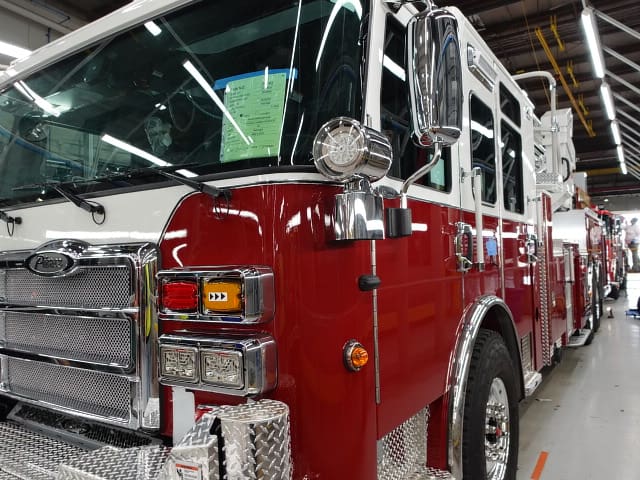

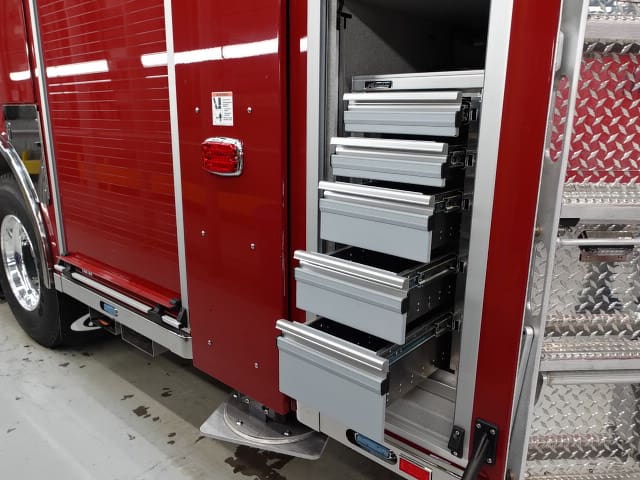

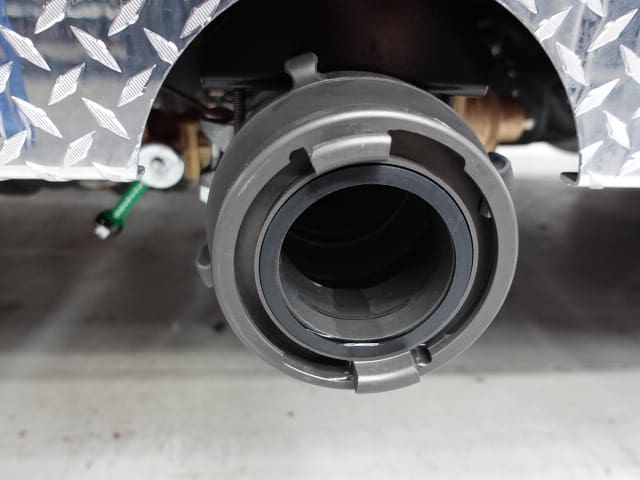

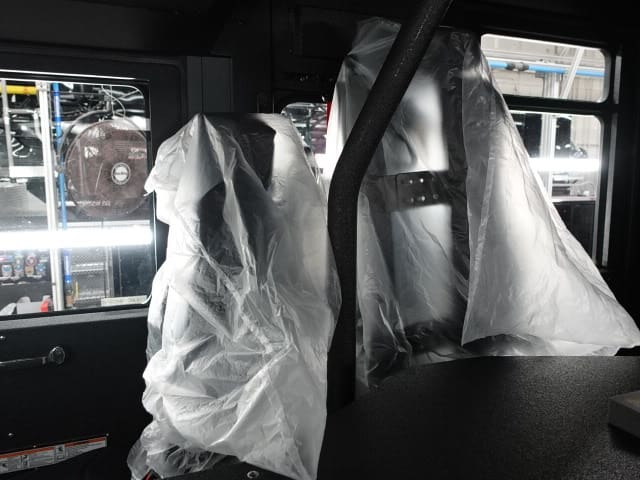

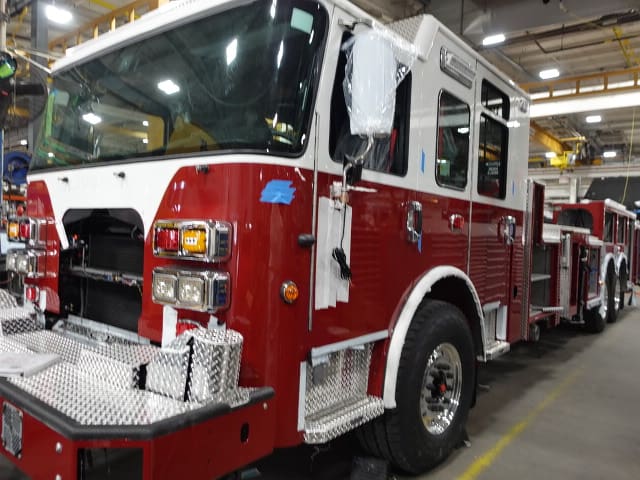

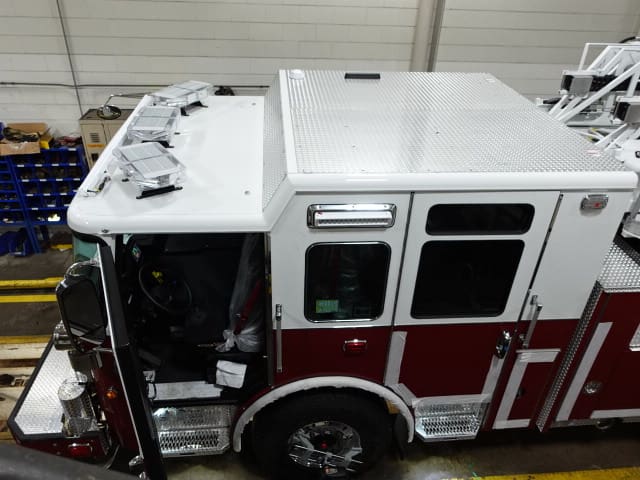

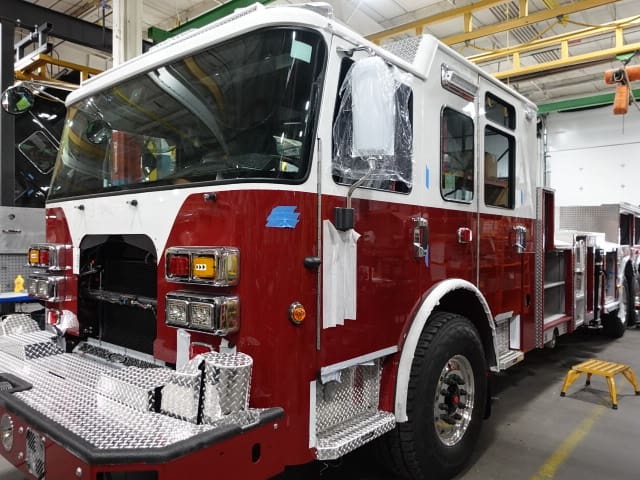

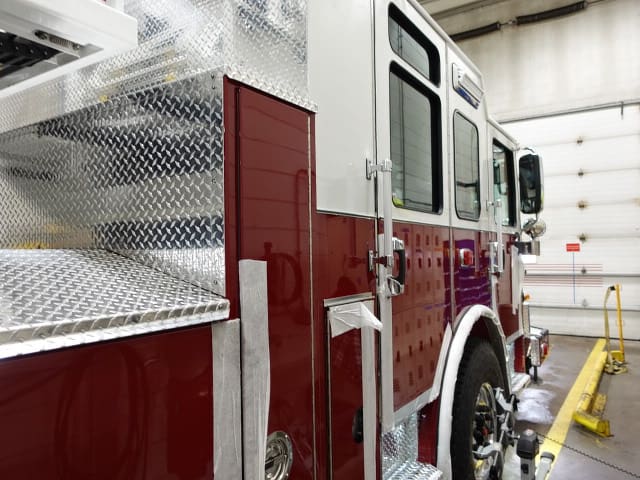

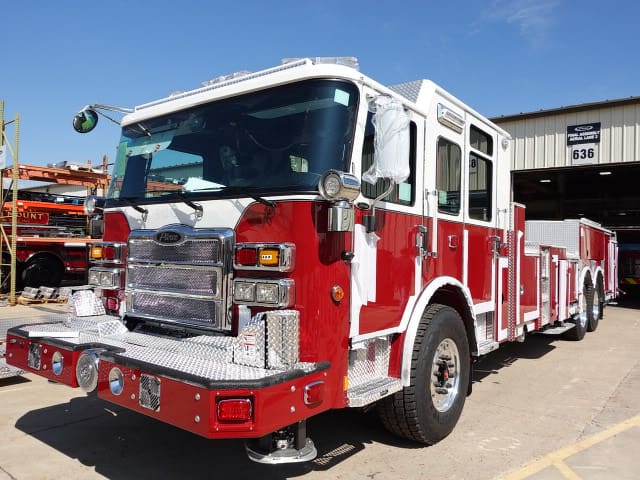

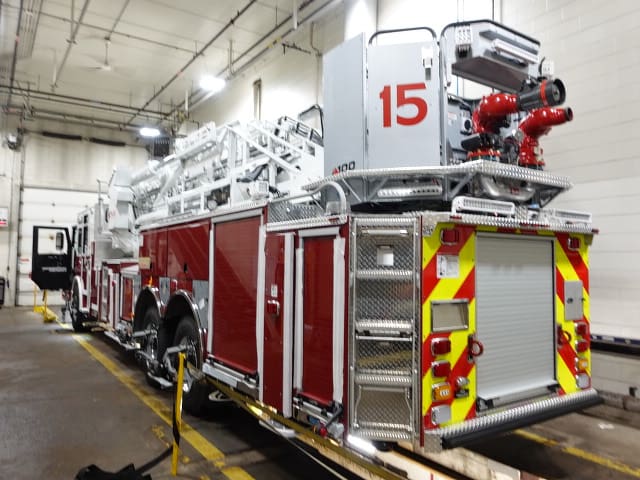

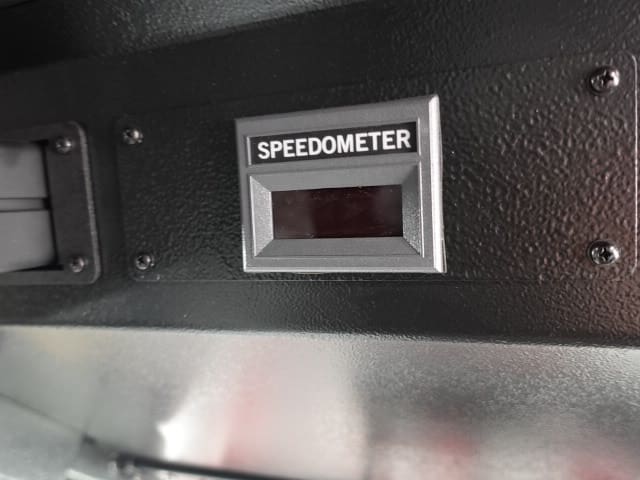

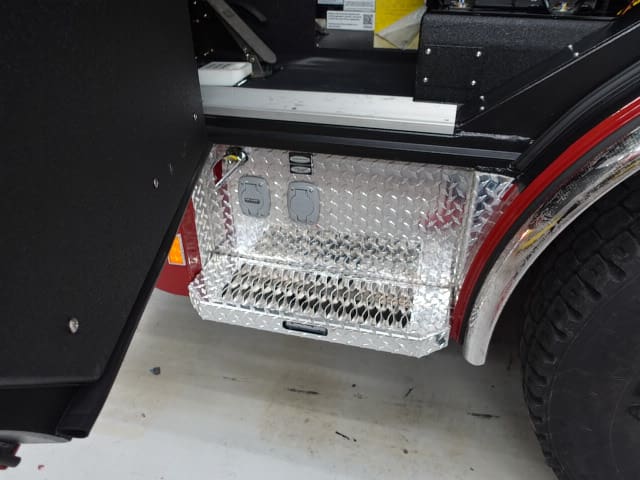

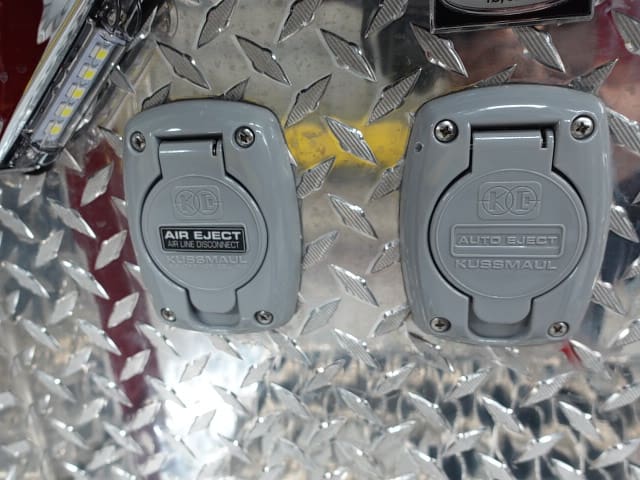

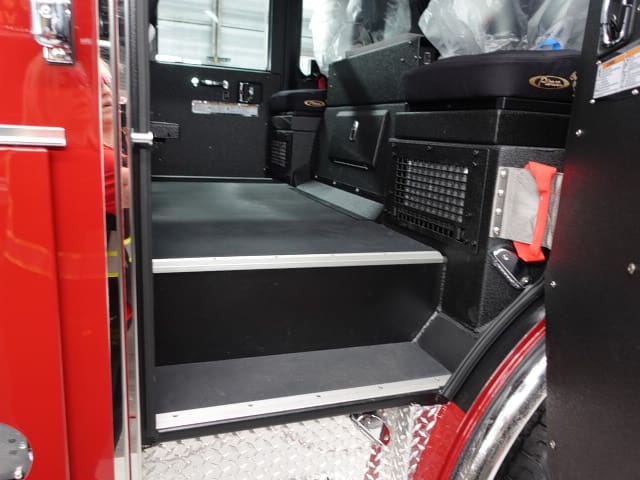

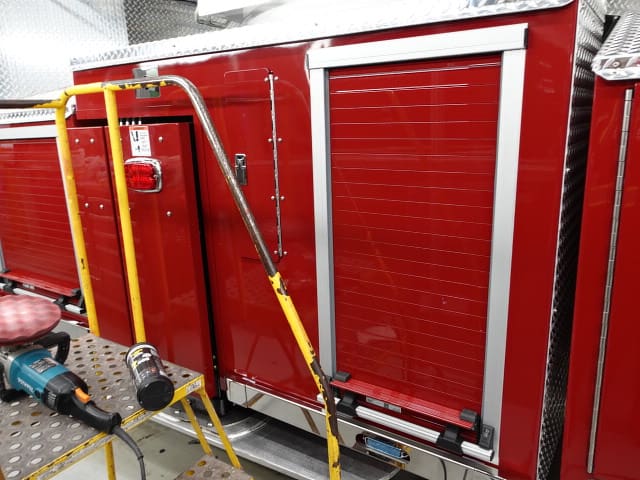

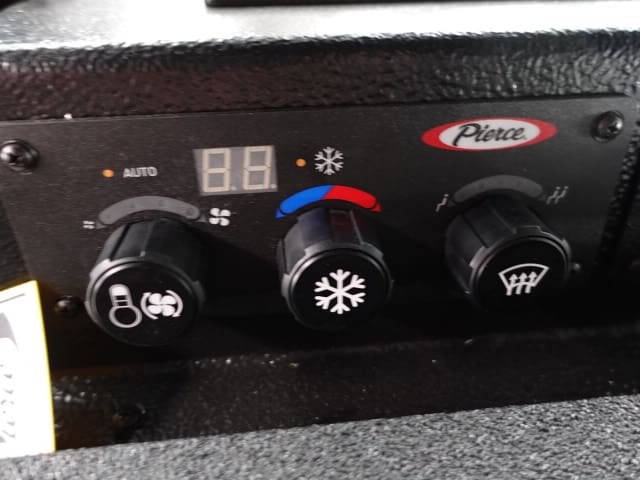

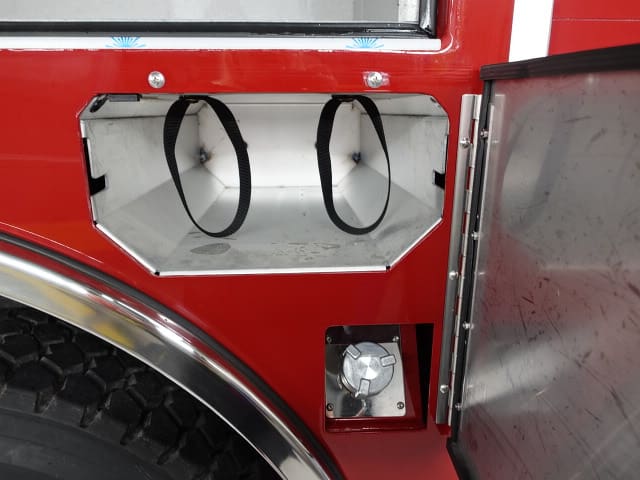

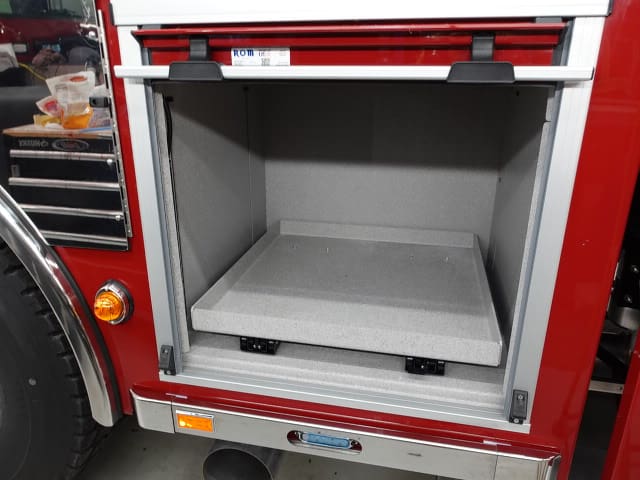

In this report, the apparatus completed testing followed by release to quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
05-23-25

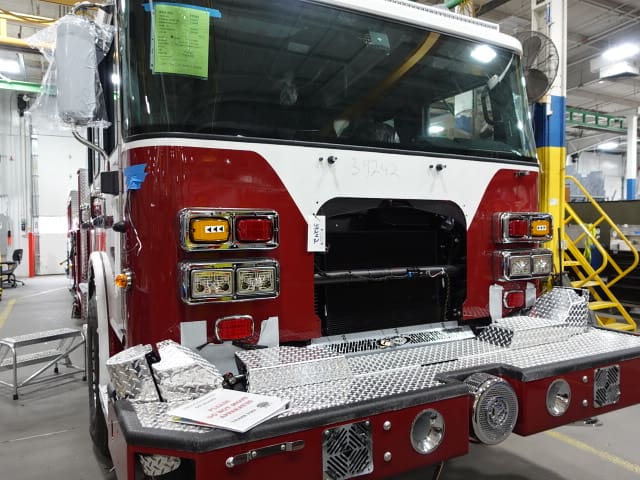

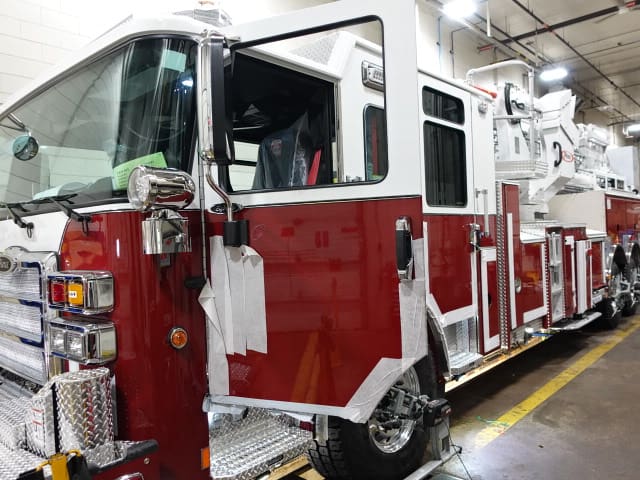

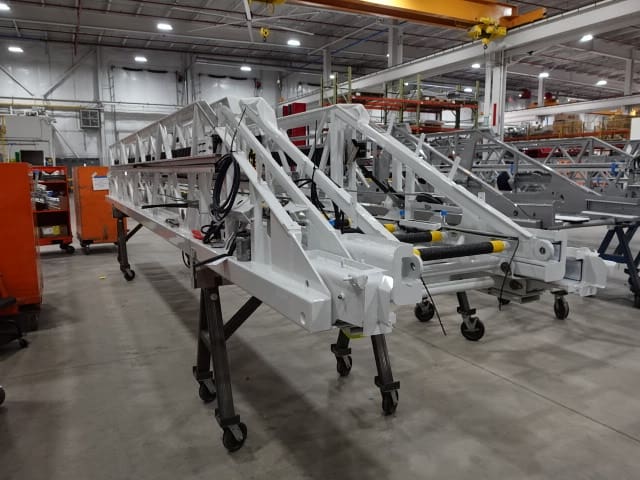

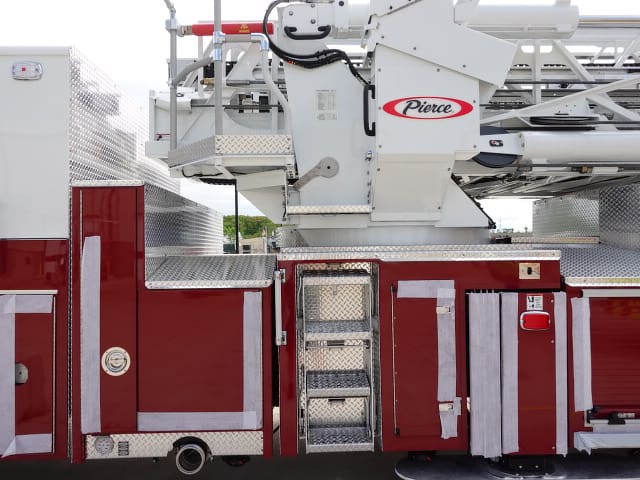

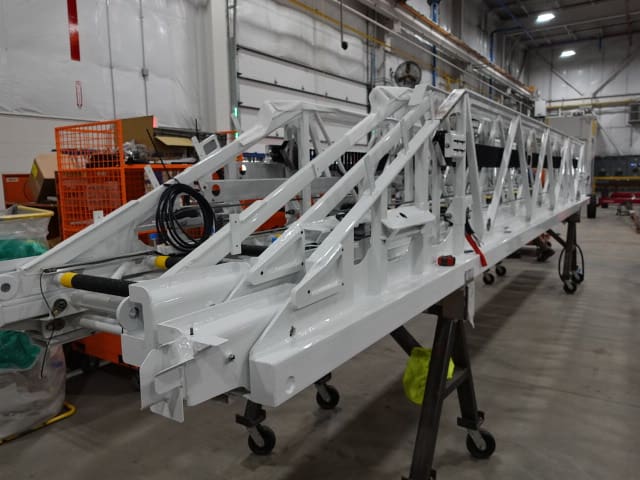

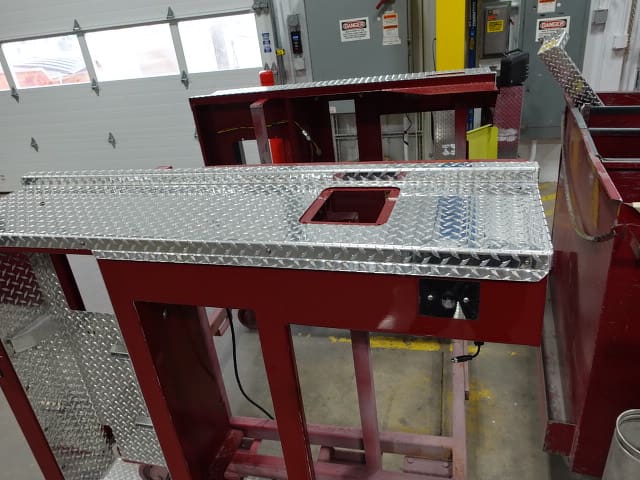

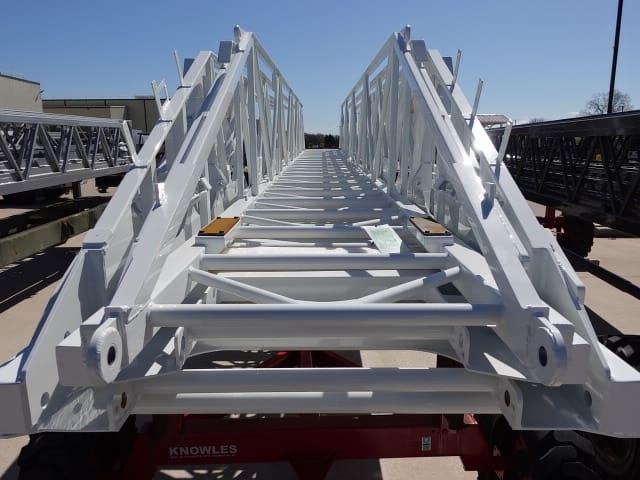

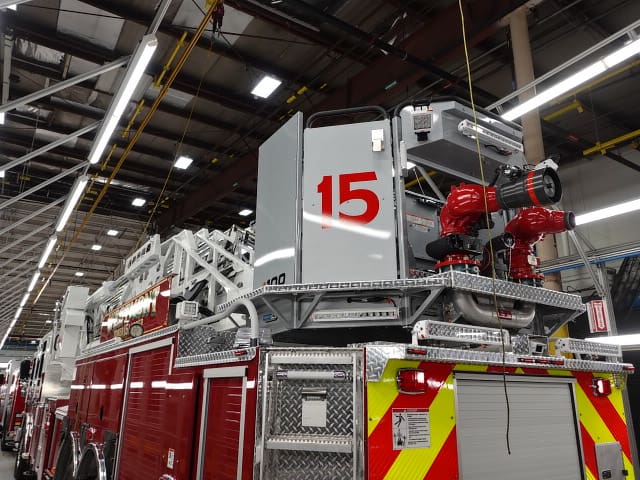

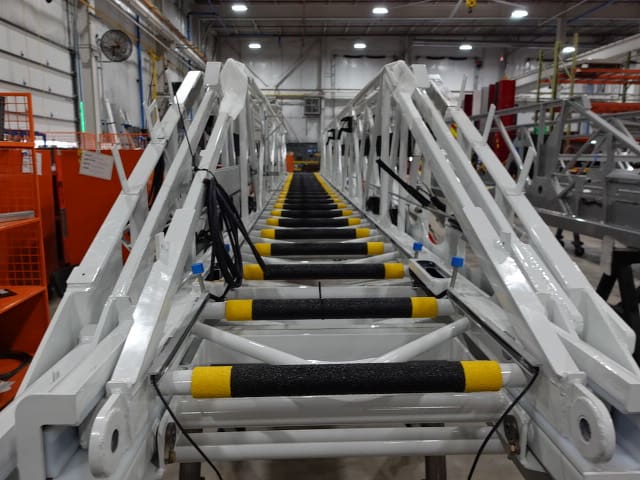

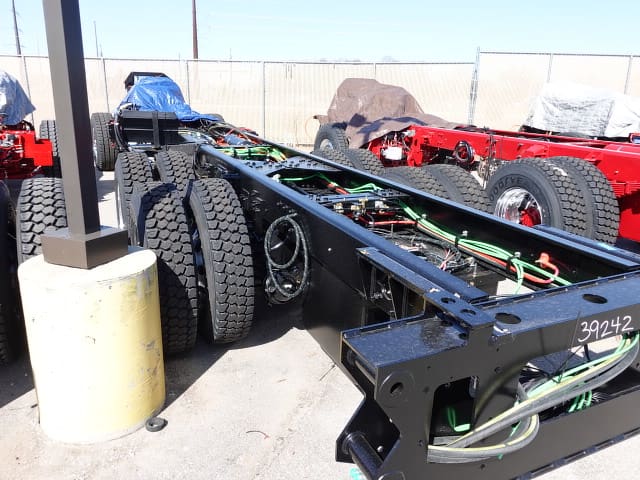

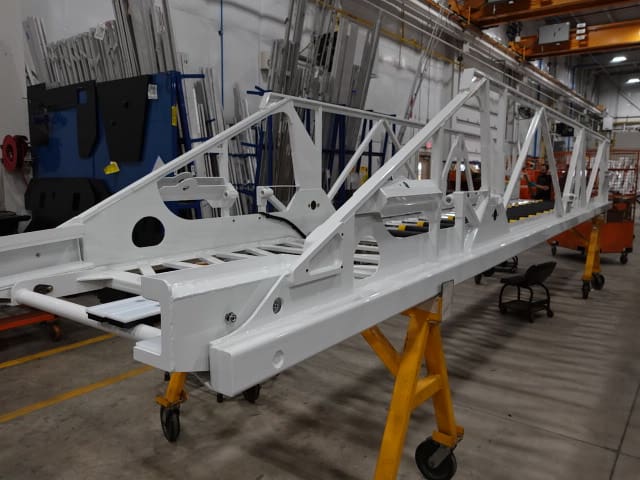

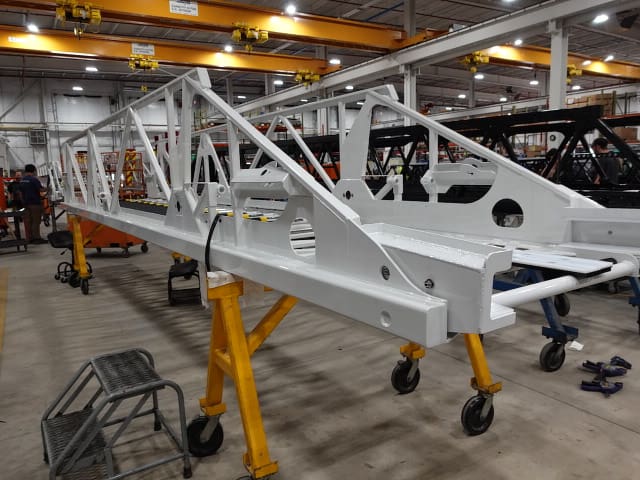

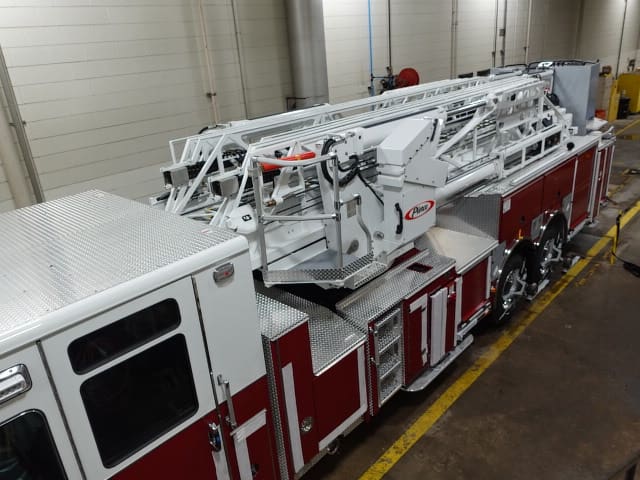

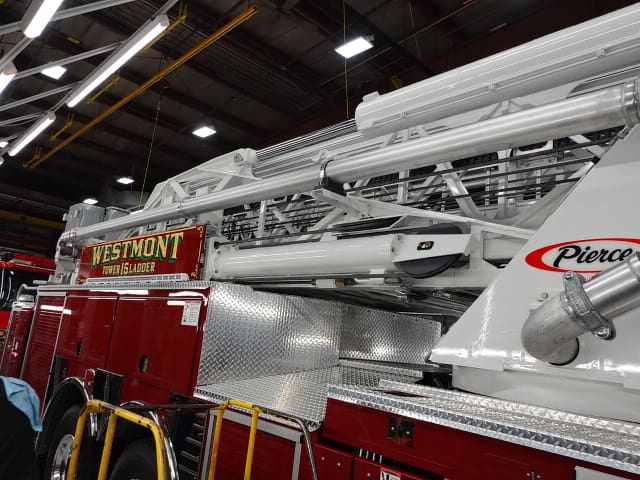

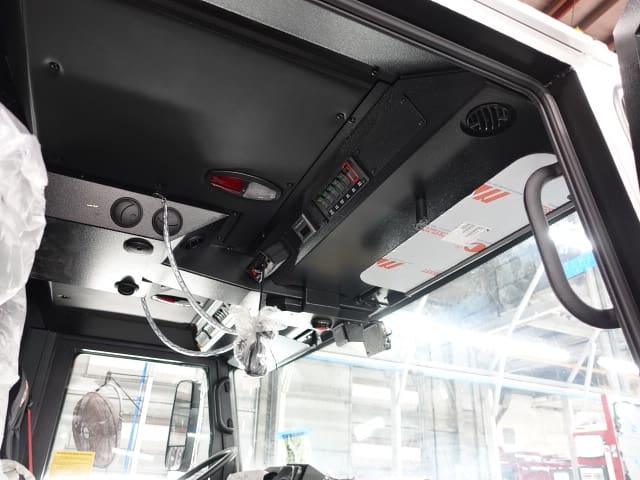

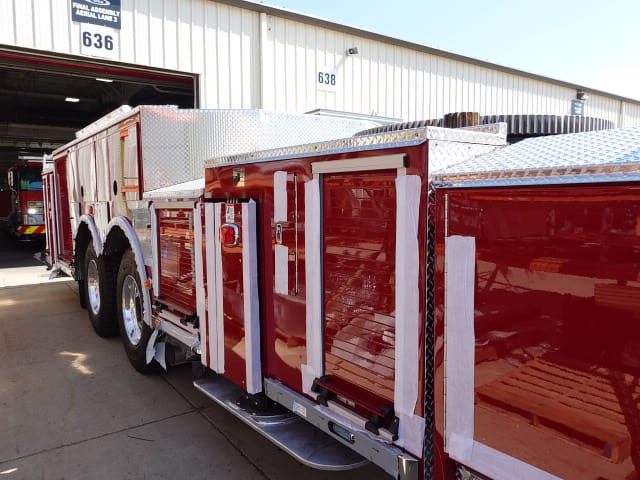

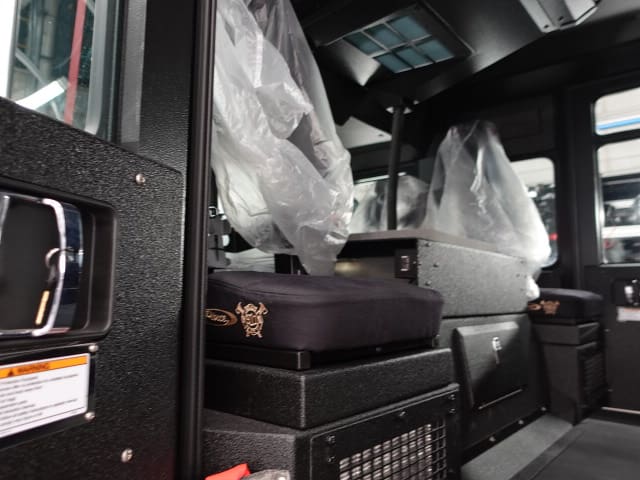

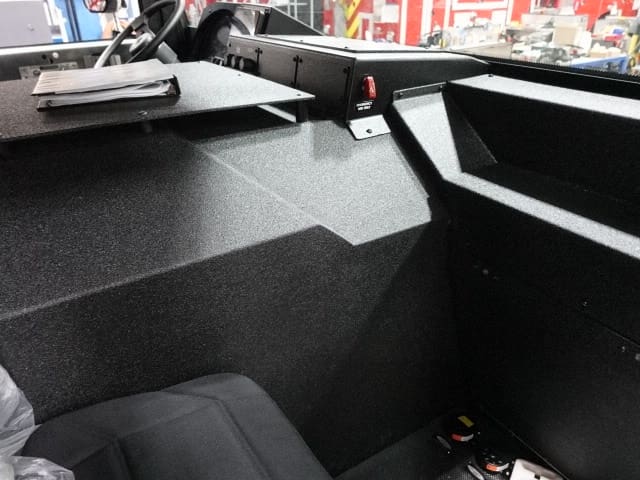

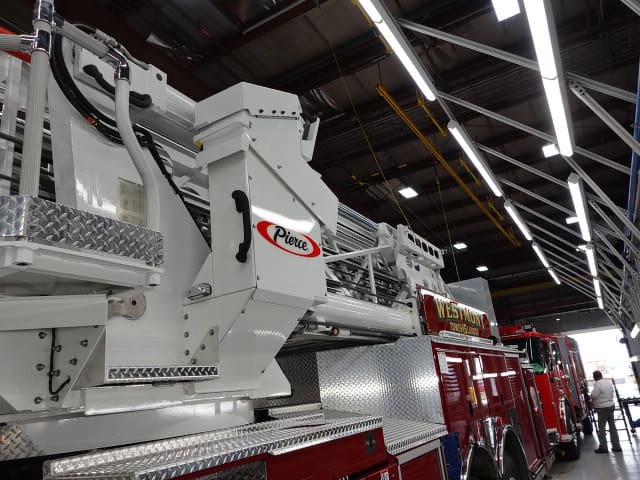

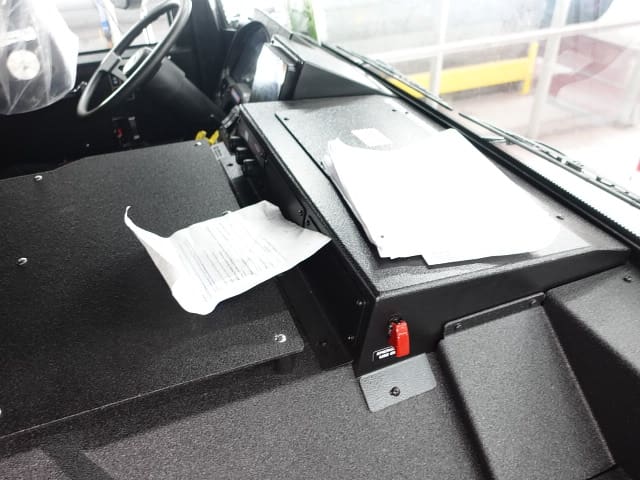

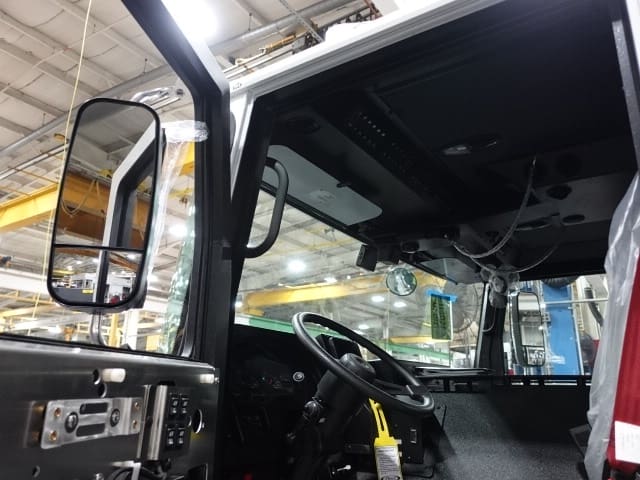

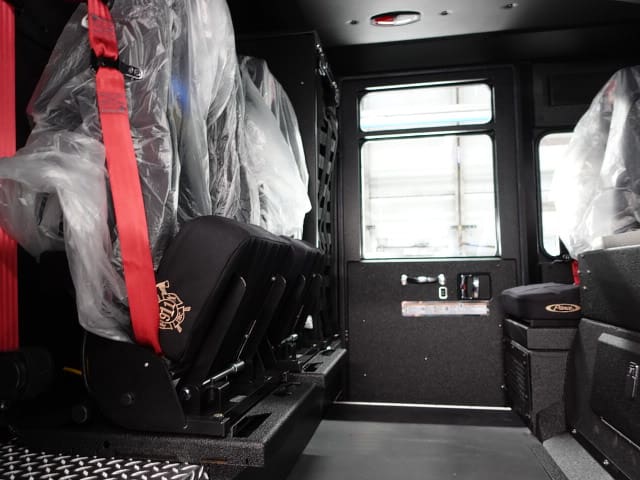

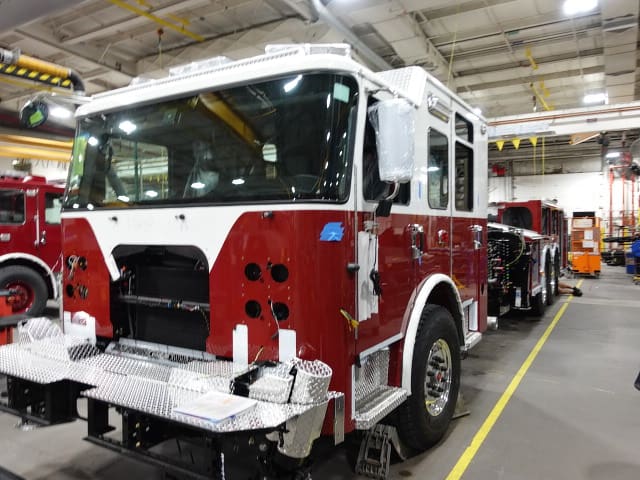

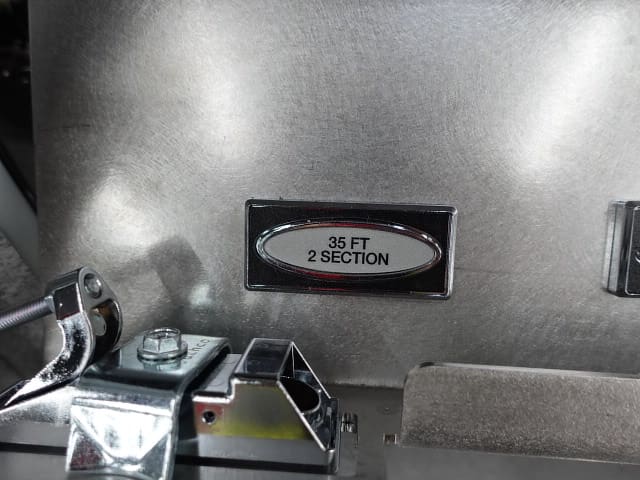

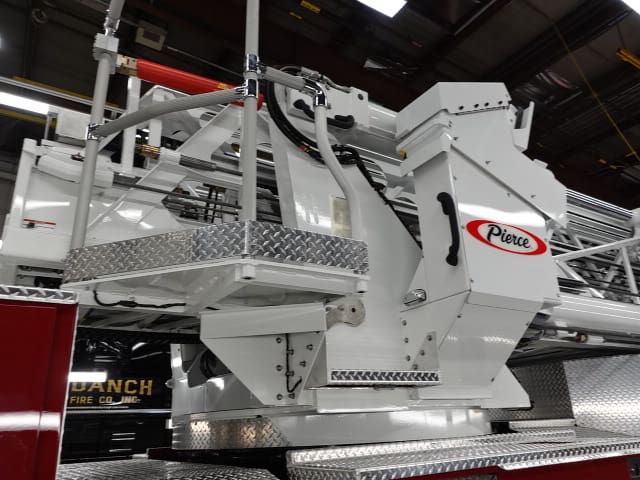

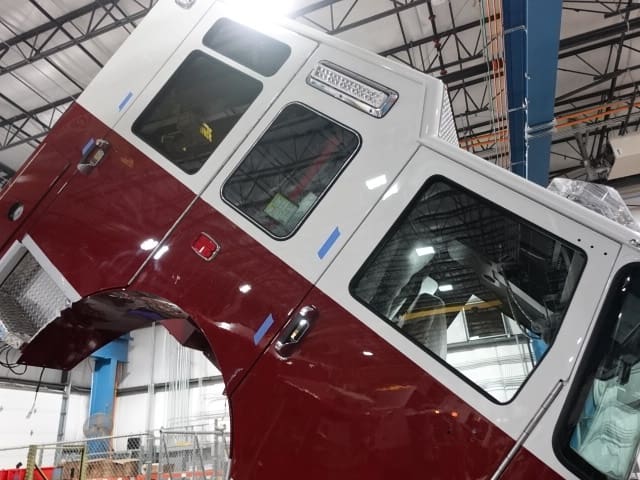

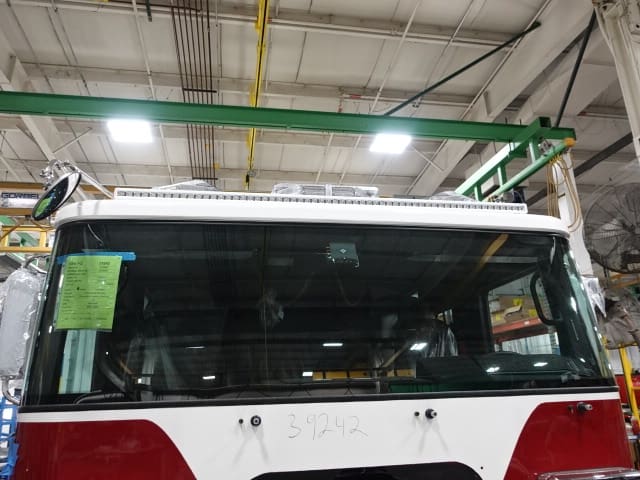

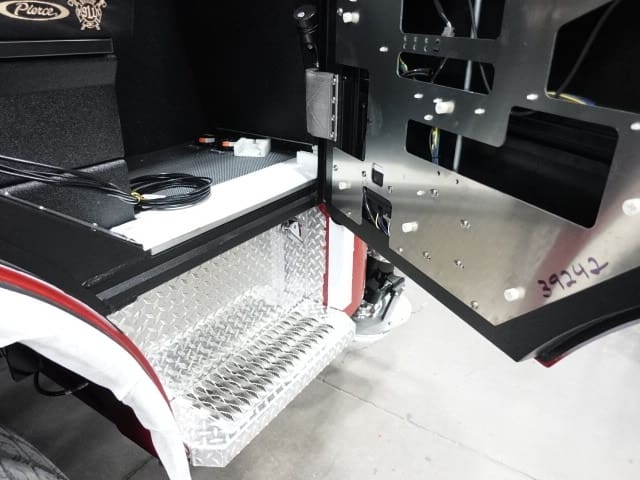

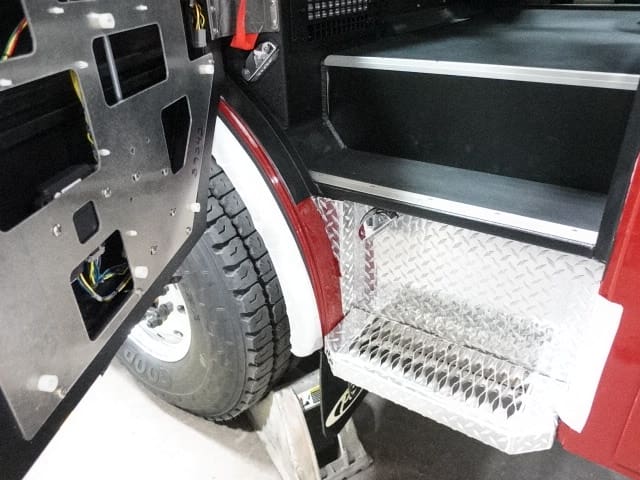

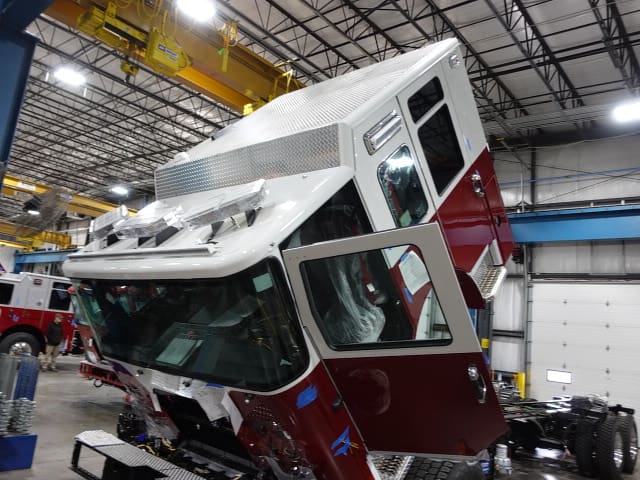

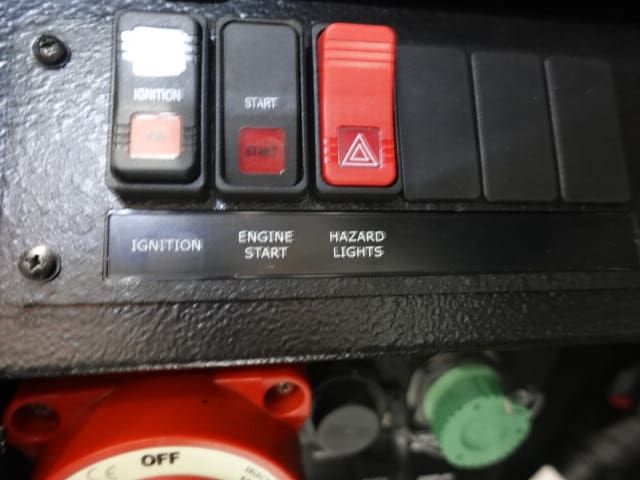

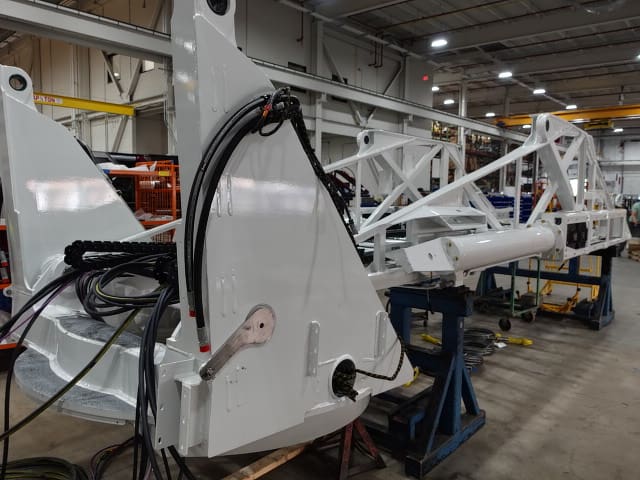

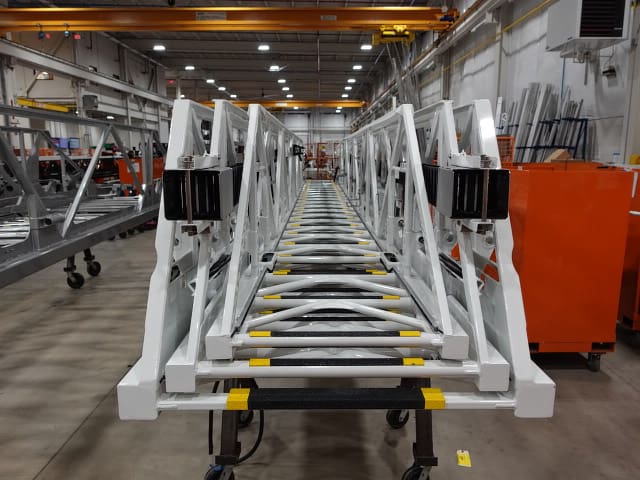

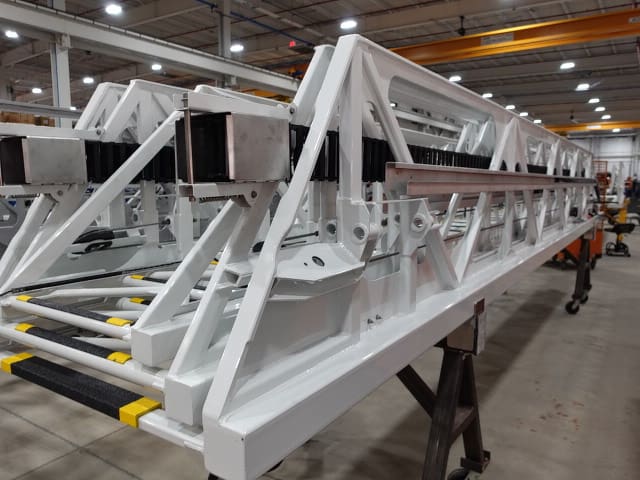

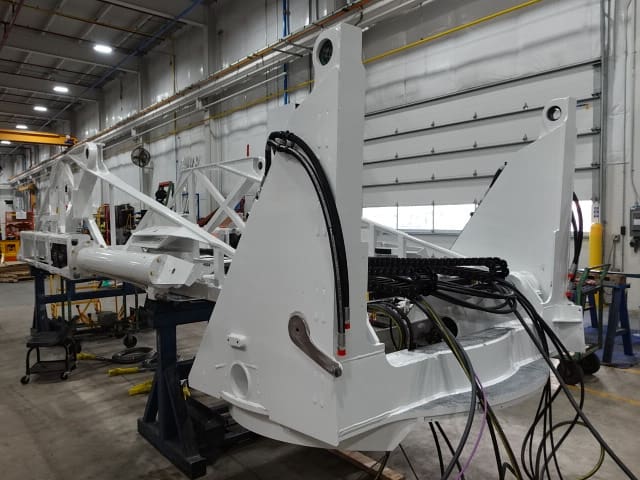

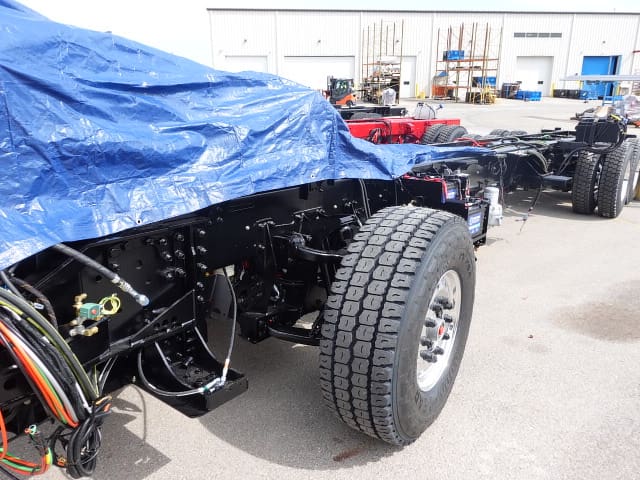

In this report, the aerial device completed initial assembly and was pinned to your apparatus followed by release to alignment and testing.
05-16-25

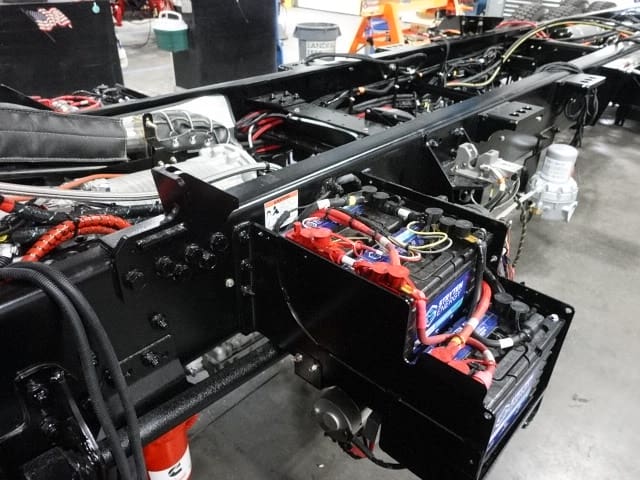

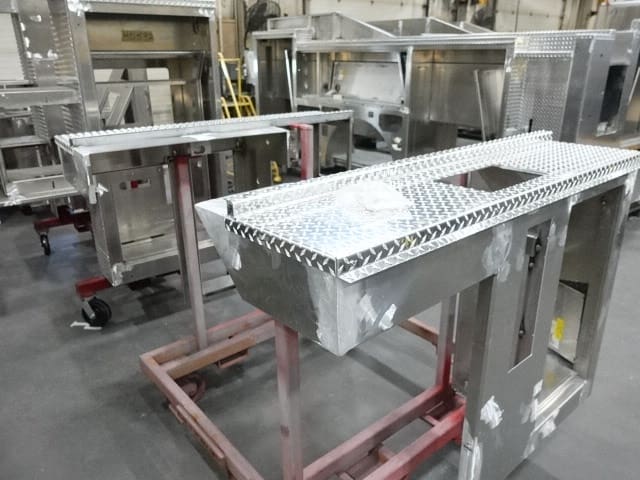

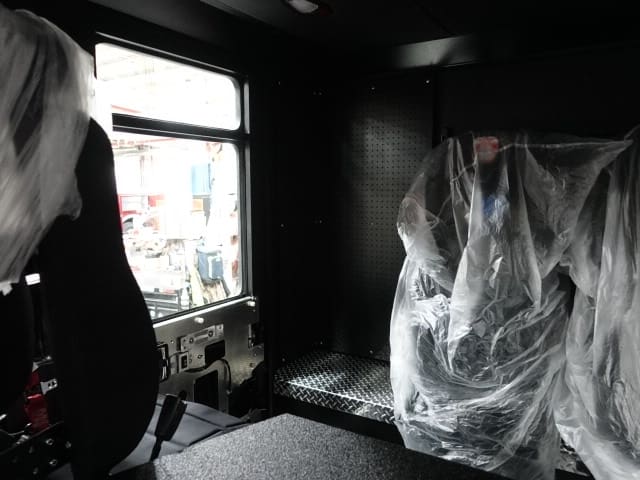

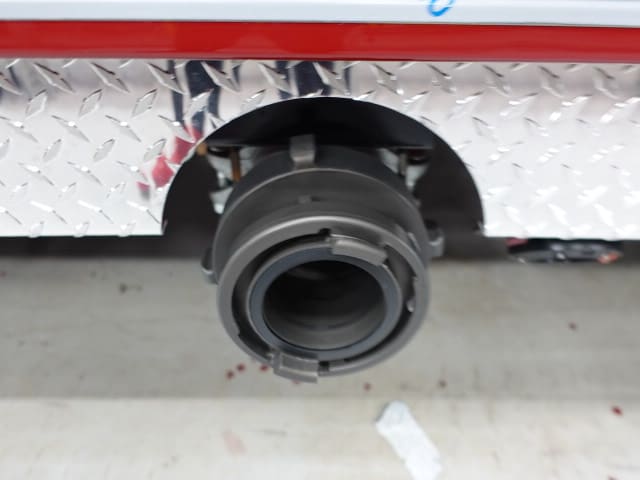

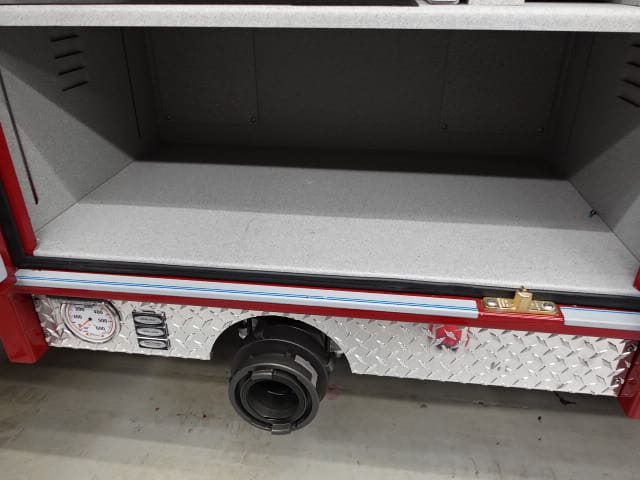

In this report, the apparatus completed final assembly while the aerial device began initial assembly.
05-09-25

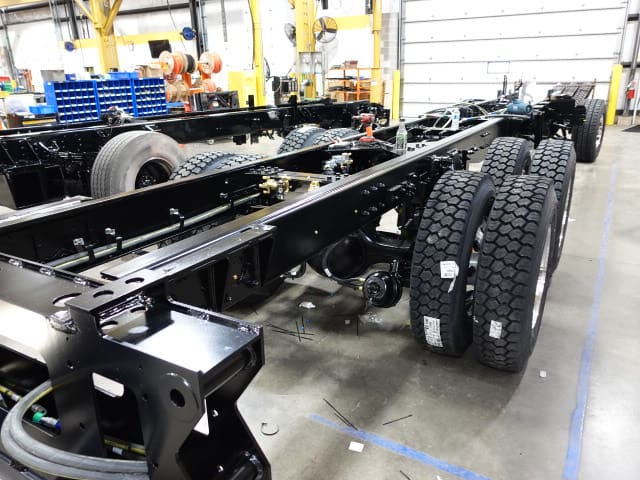

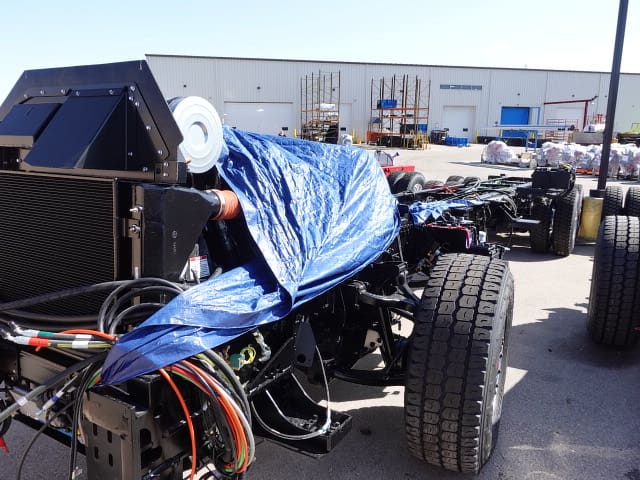

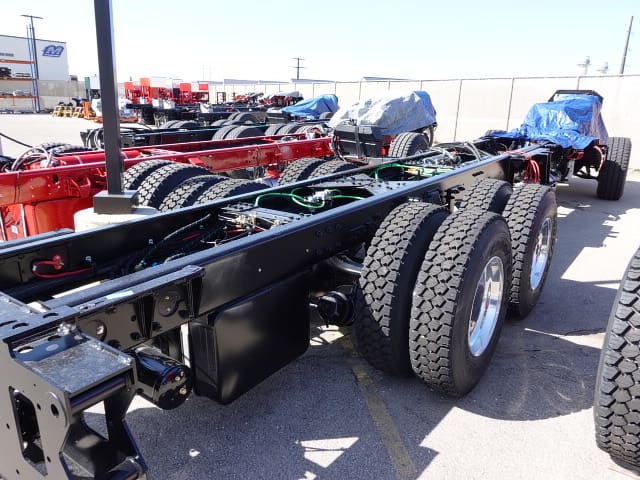

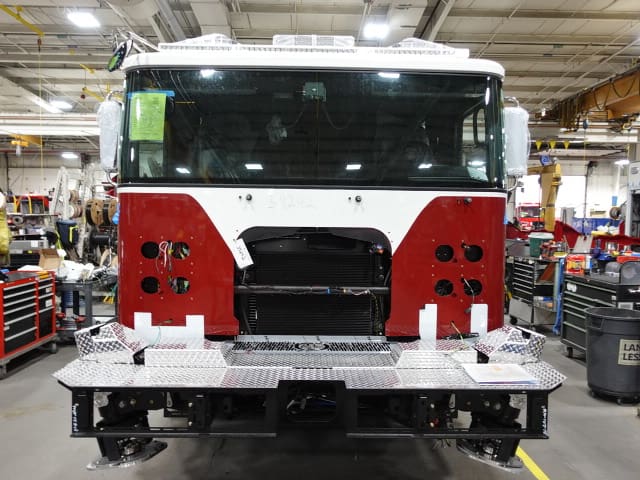

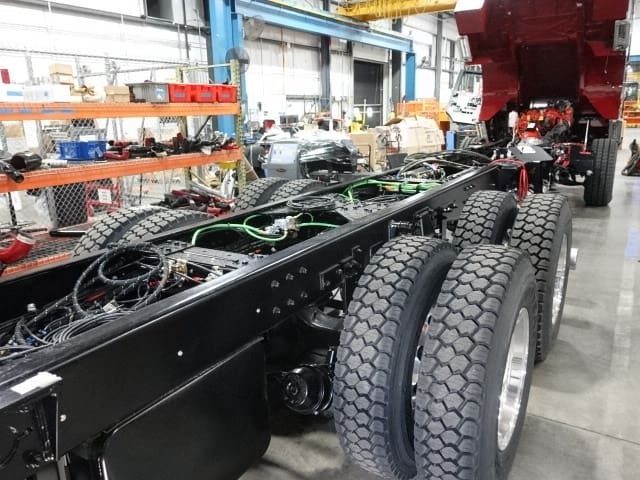

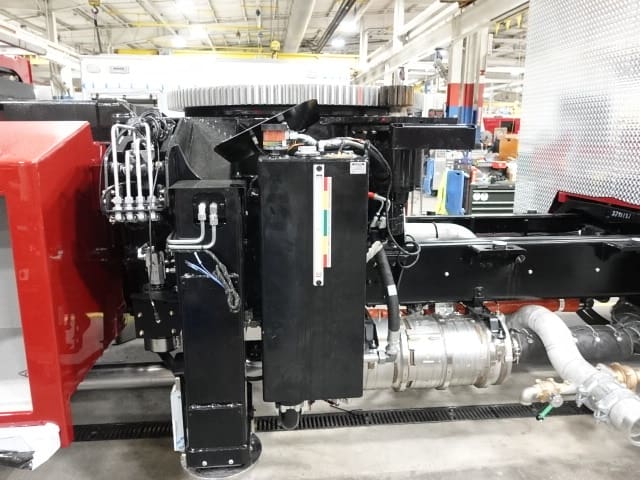

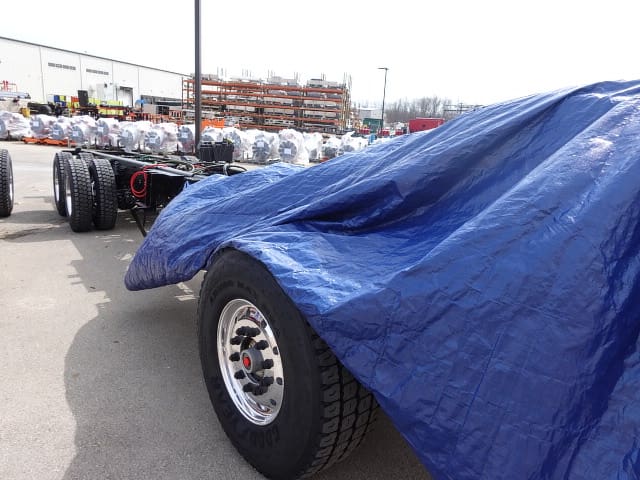

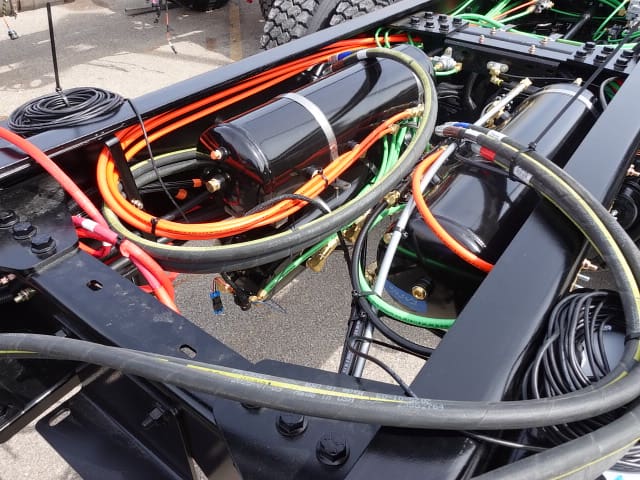

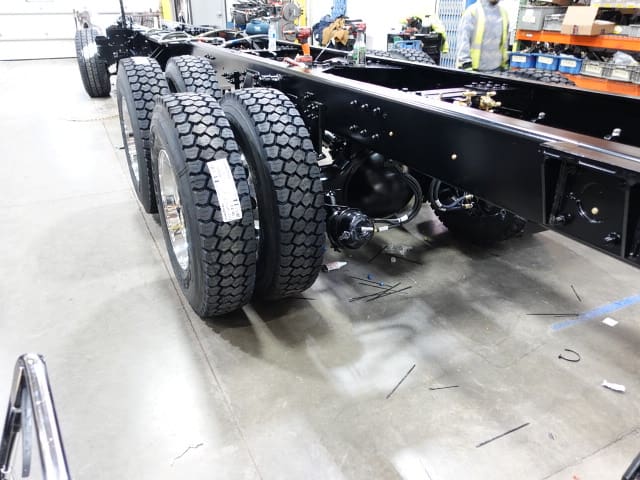

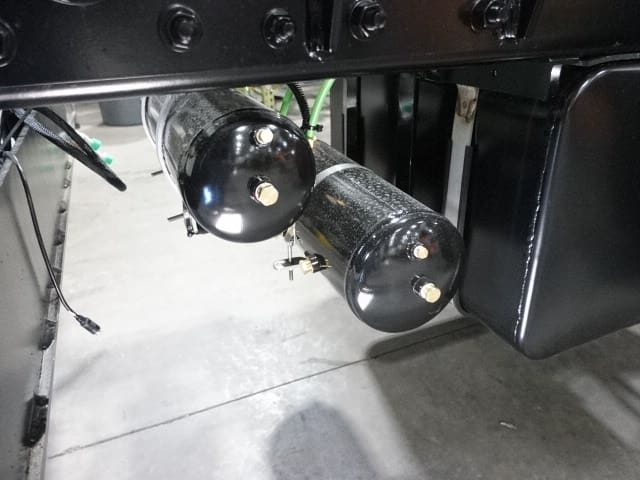

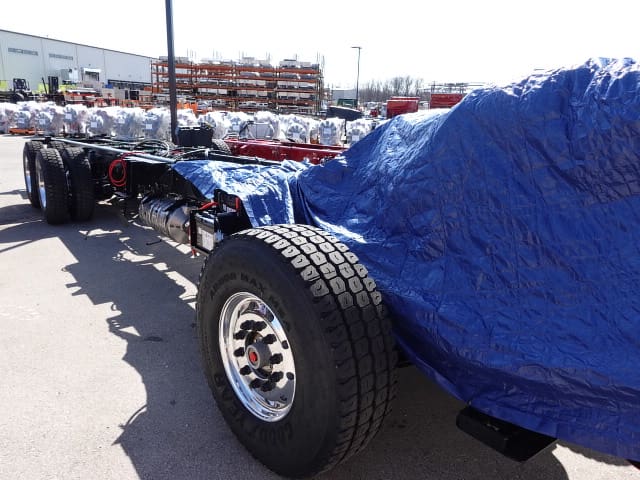

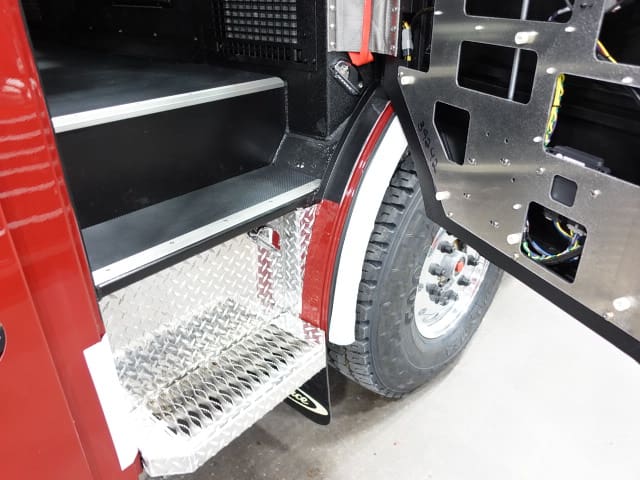

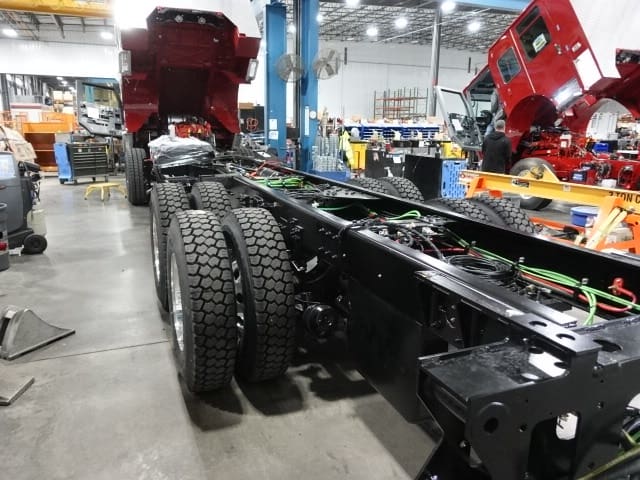

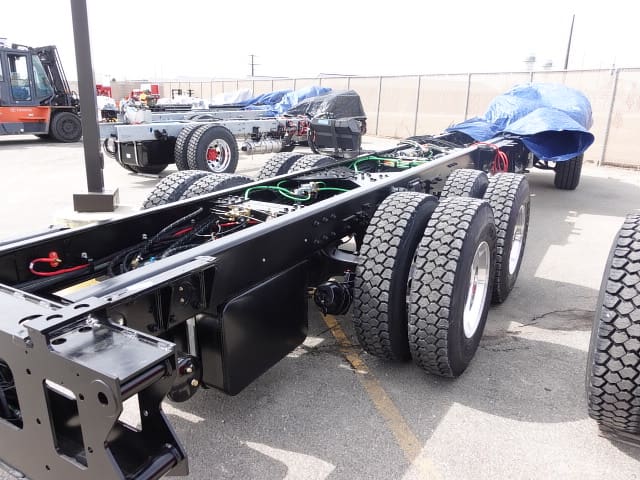

In this report, the apparatus completed initial assembly and began final assembly.
05-02-25

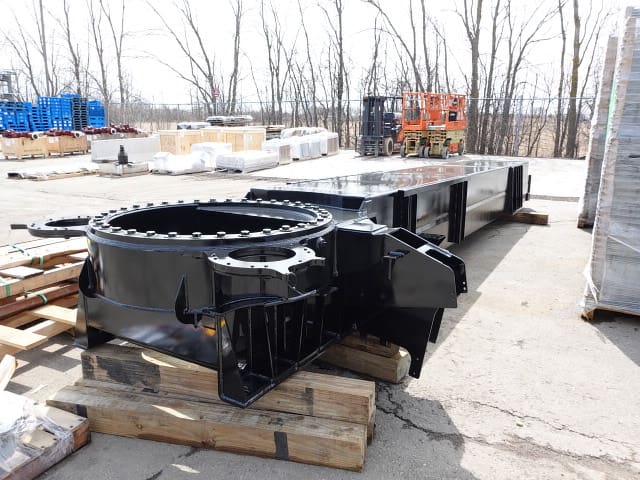

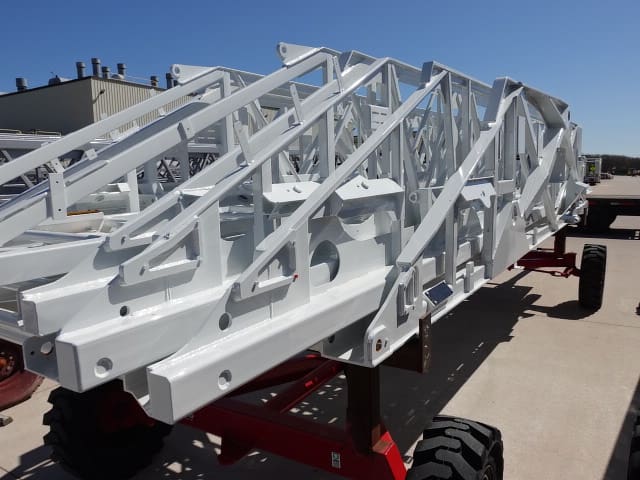

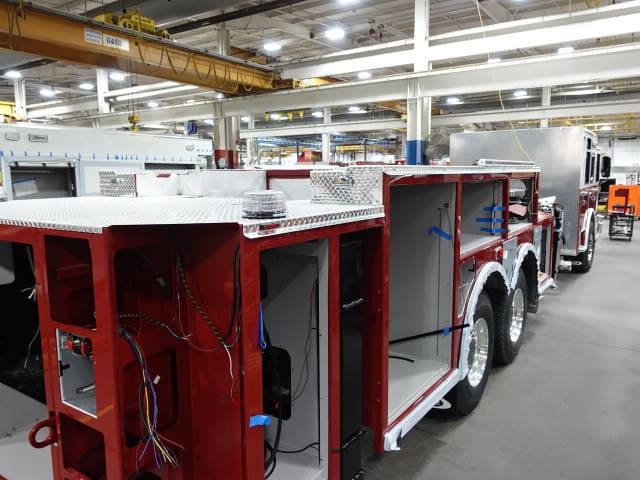

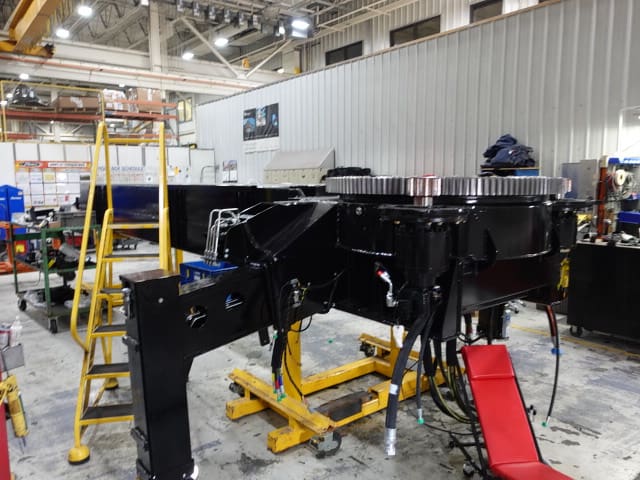

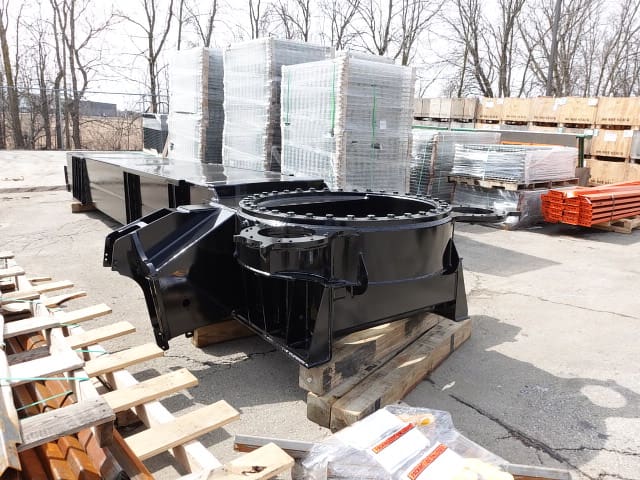

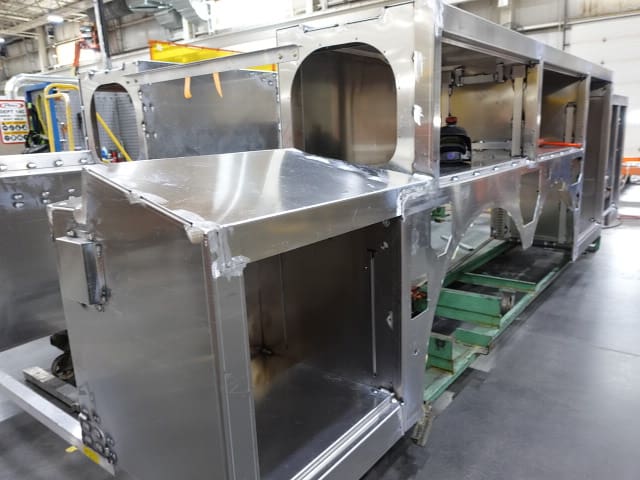

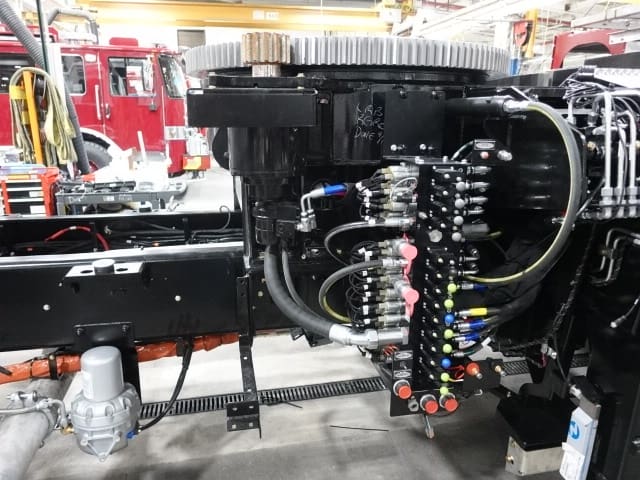

In this report, the turntable module was installed while the apparatus continued initial assembly.
04-25-25

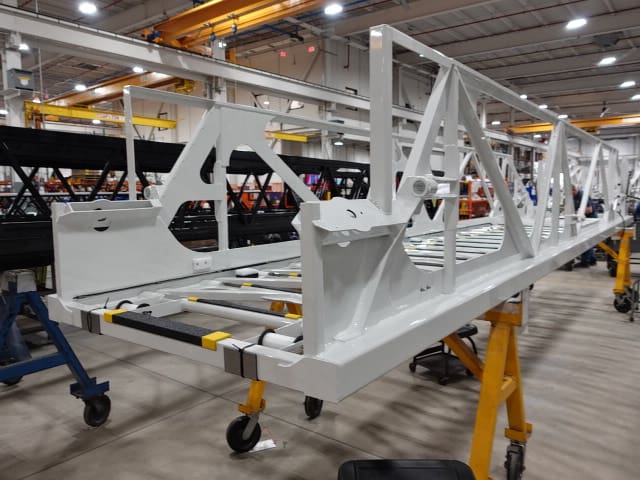

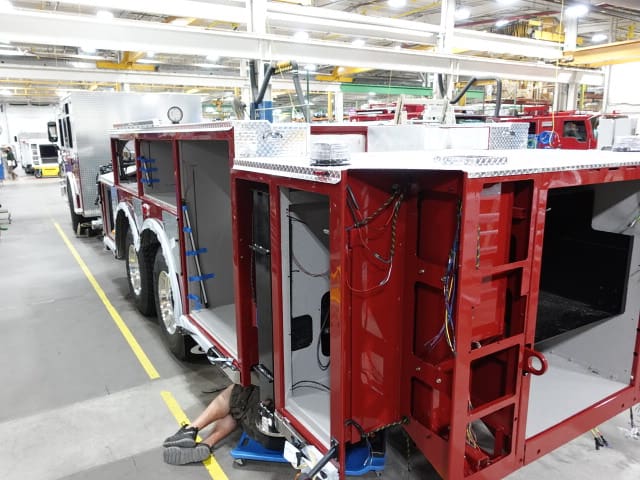

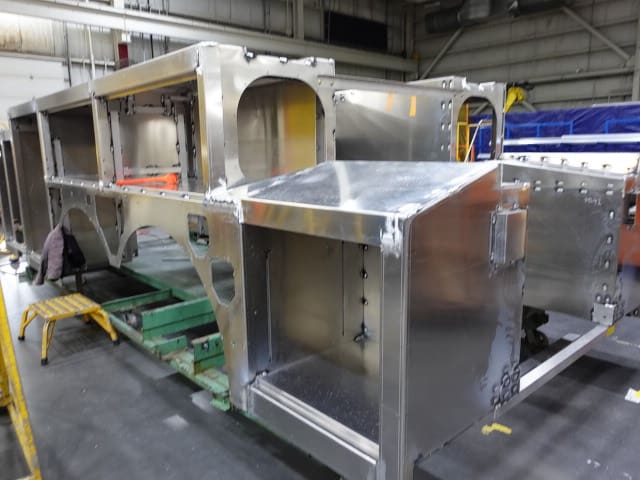

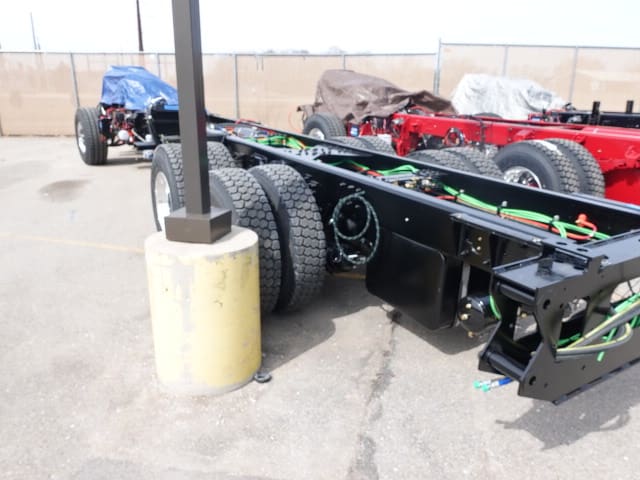

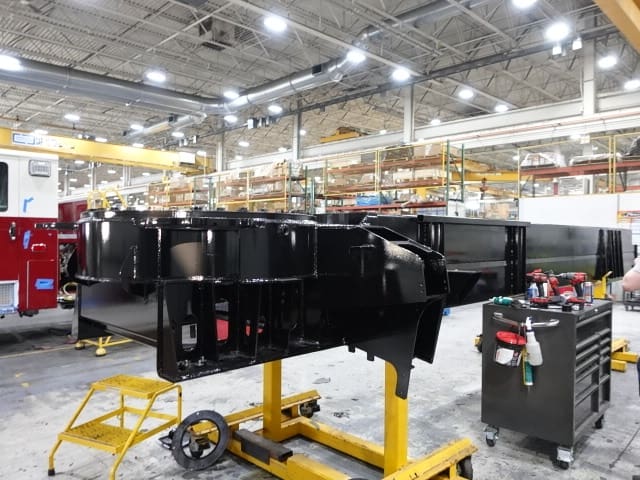

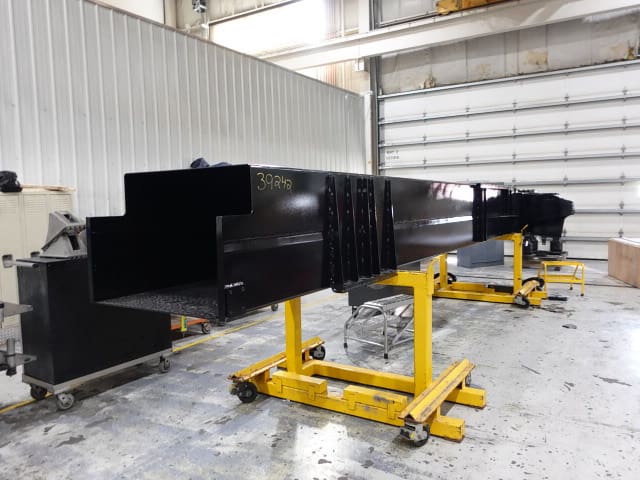

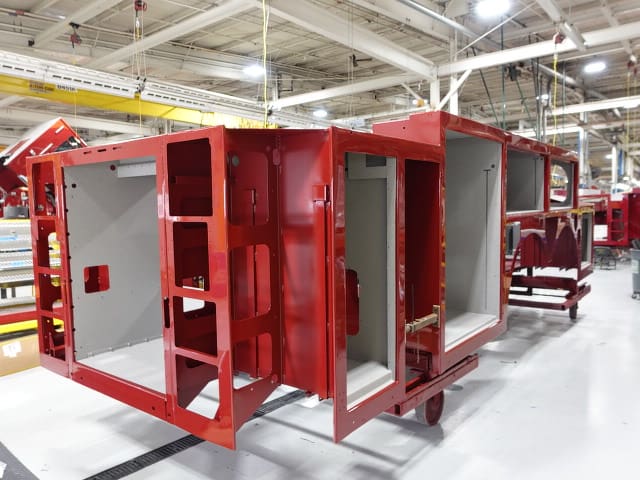

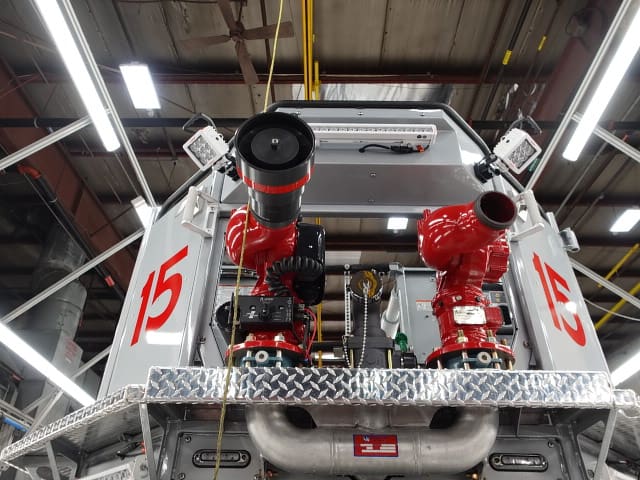

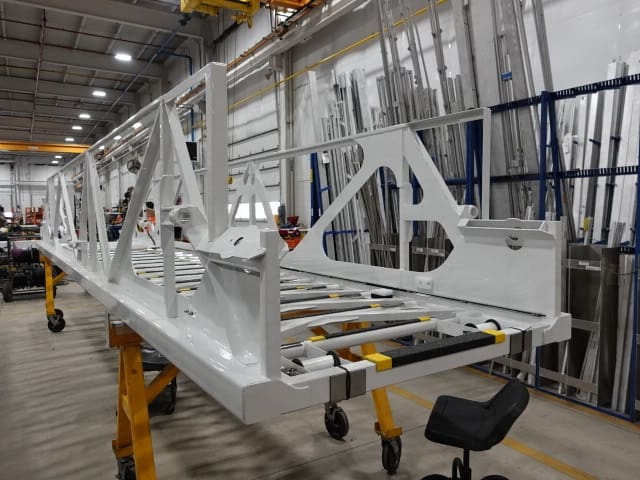

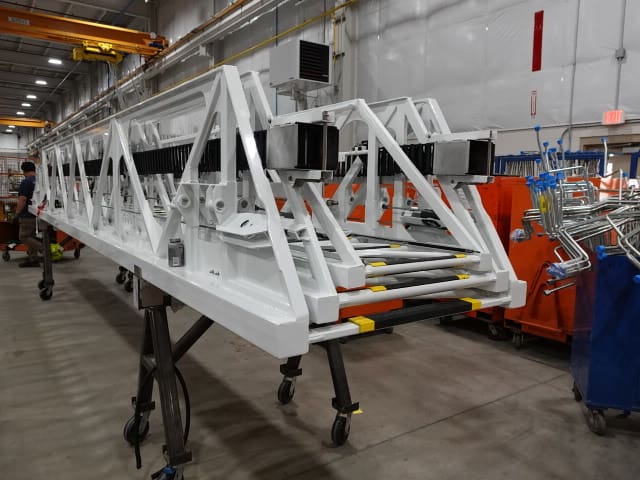

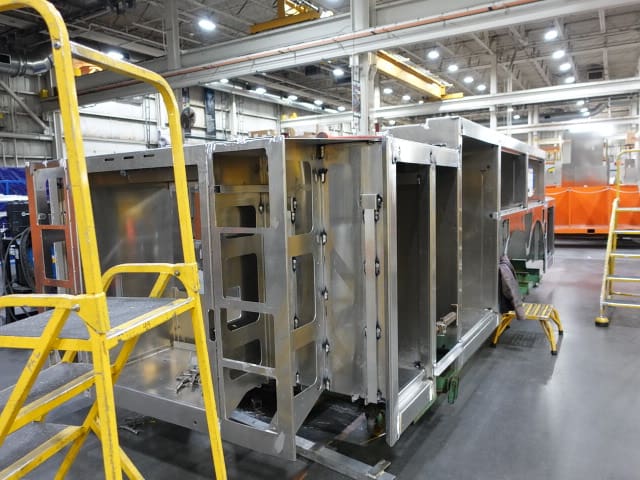

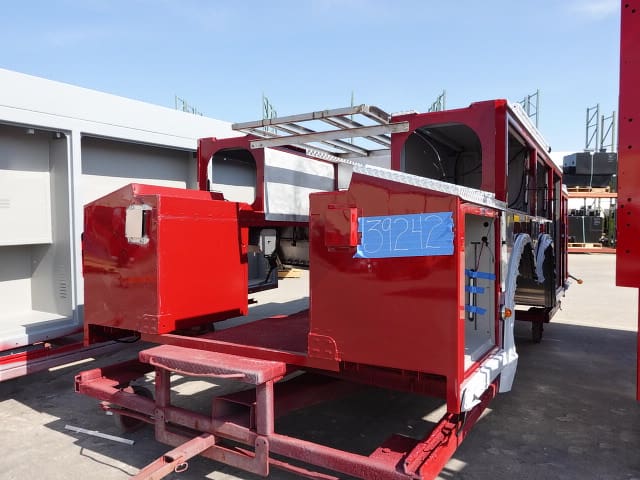

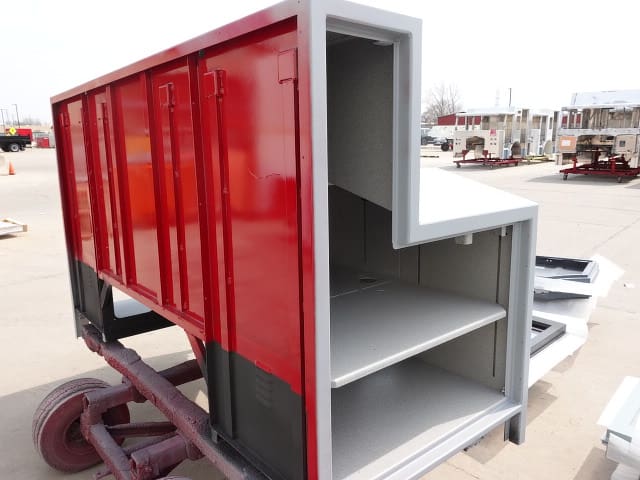

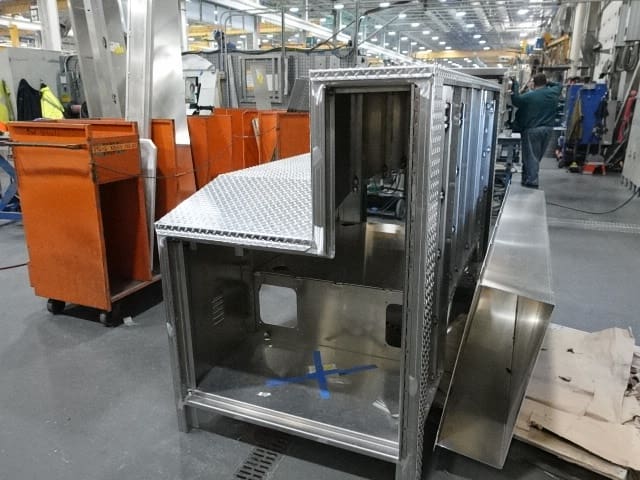

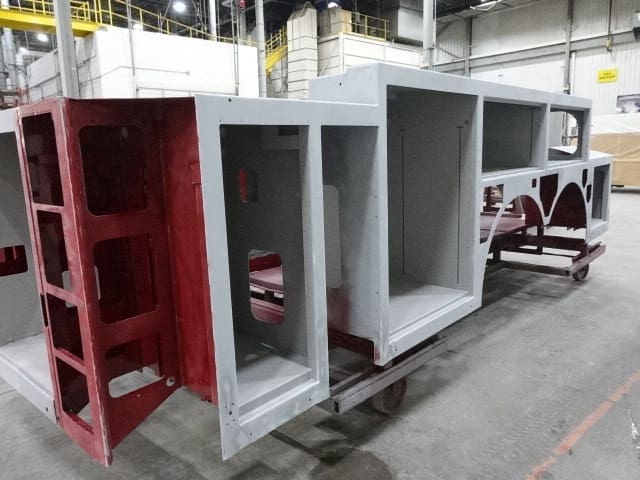

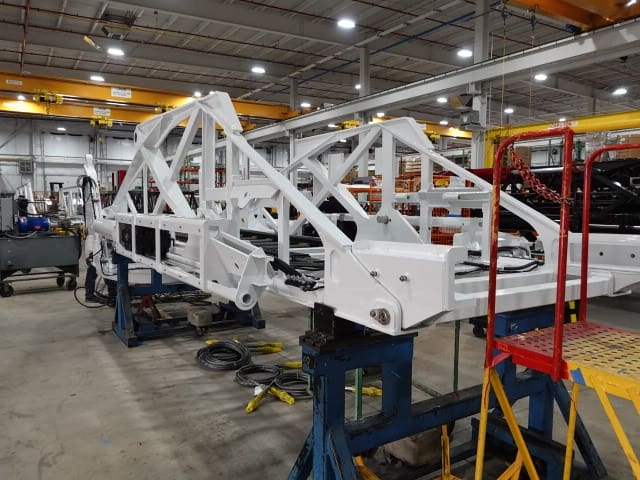

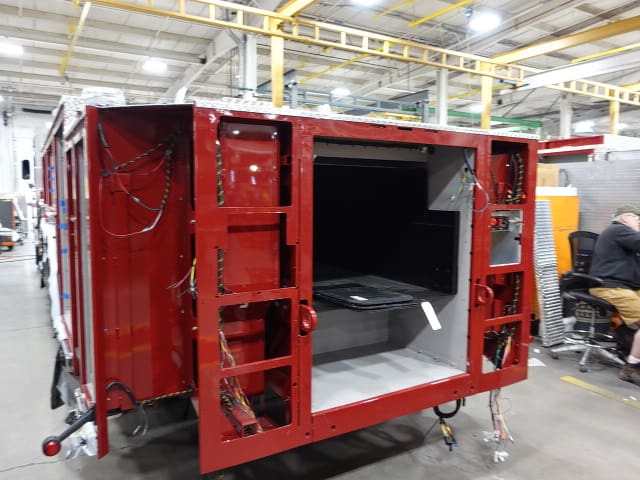

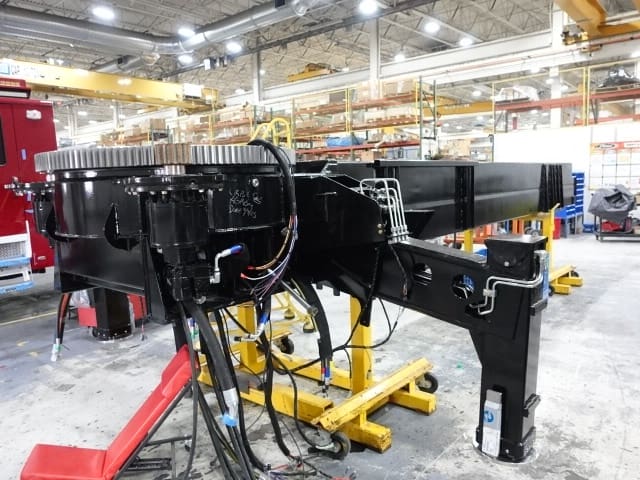

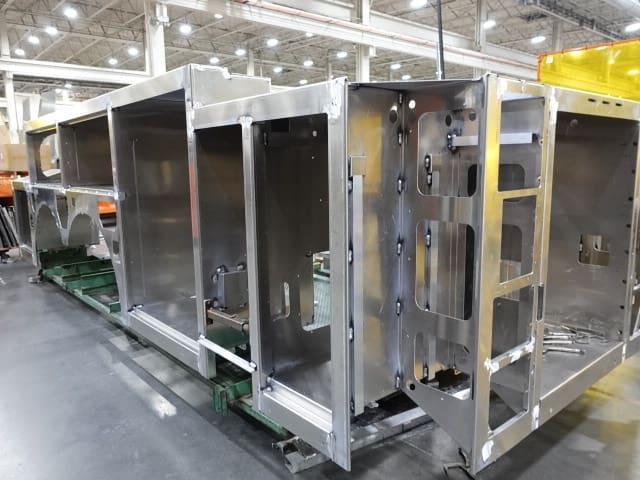

In this report the transverse, torque box, and rear body module were merged with the chassis while the turntable module completed initial assembly.

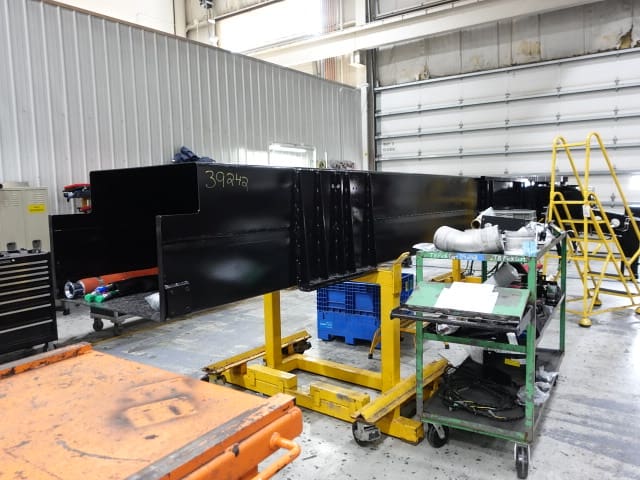

04-18-25

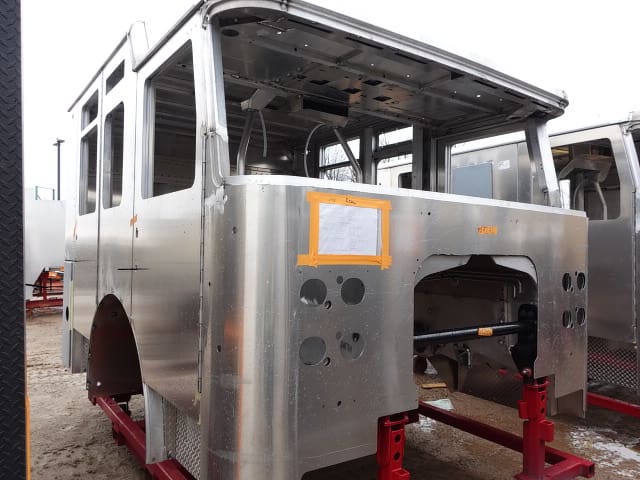

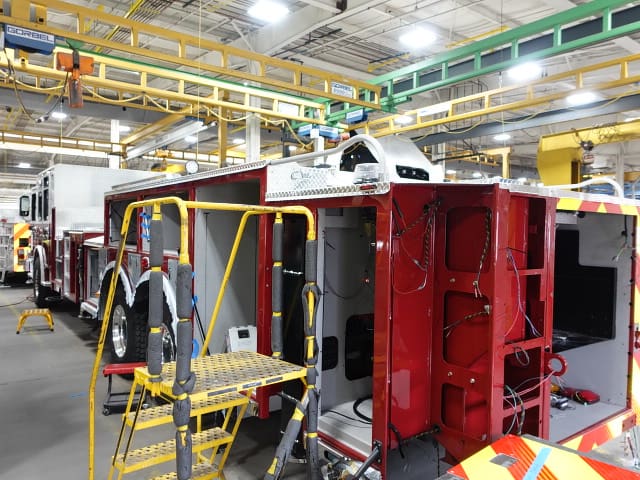

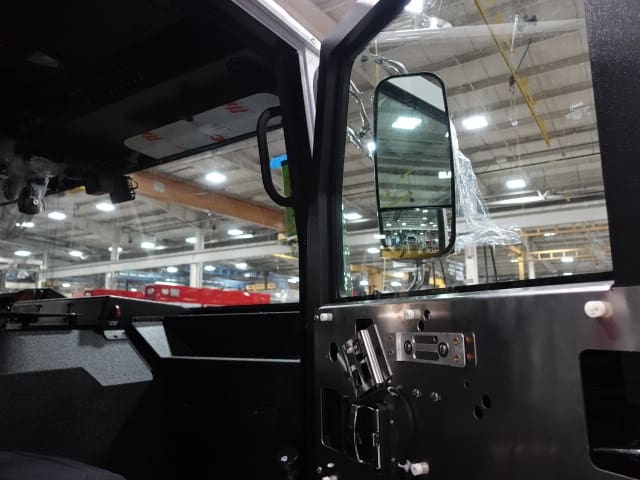

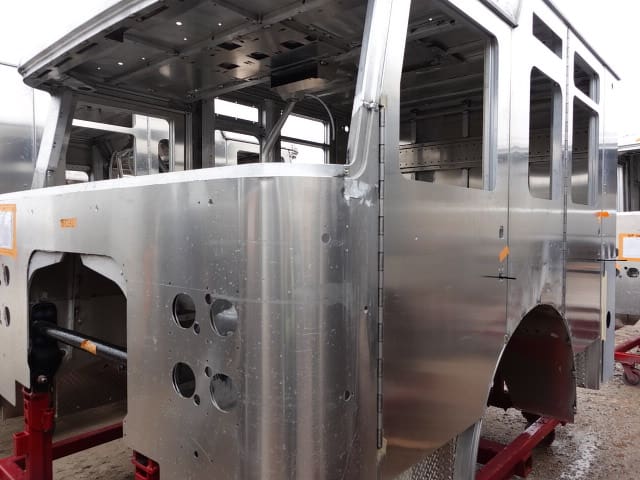

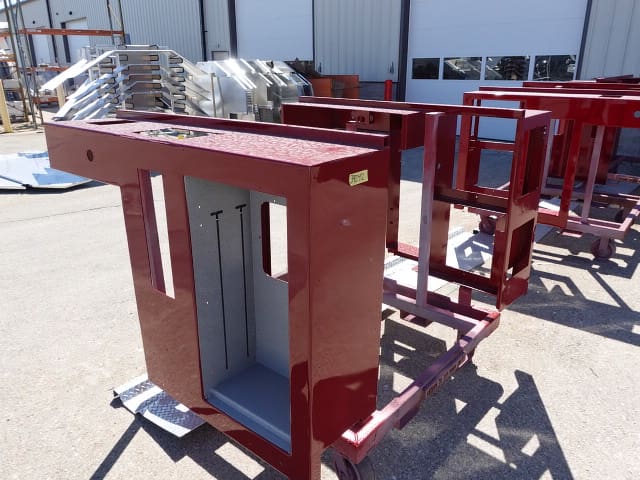

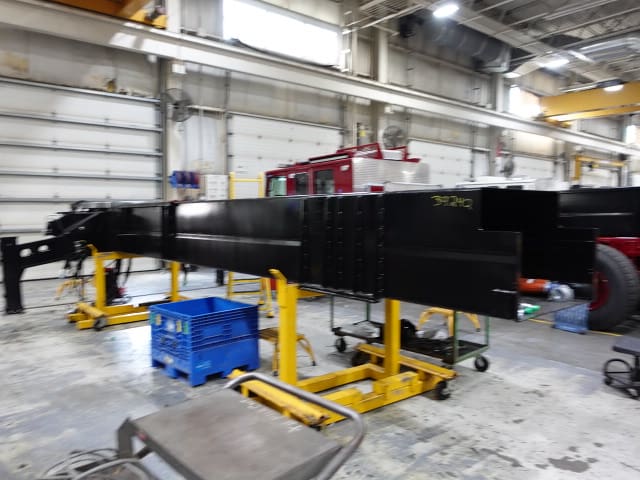

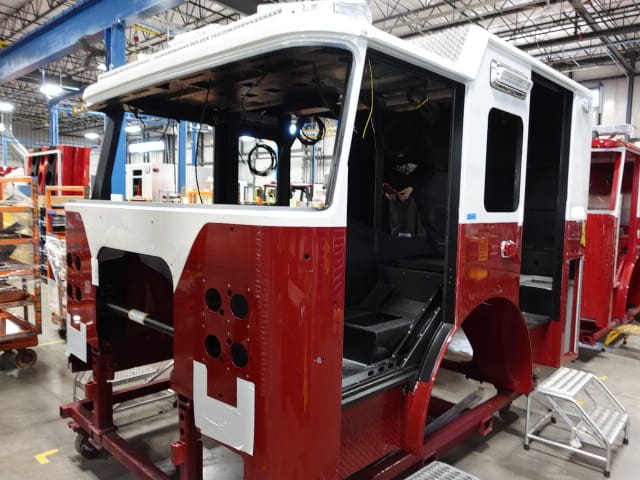

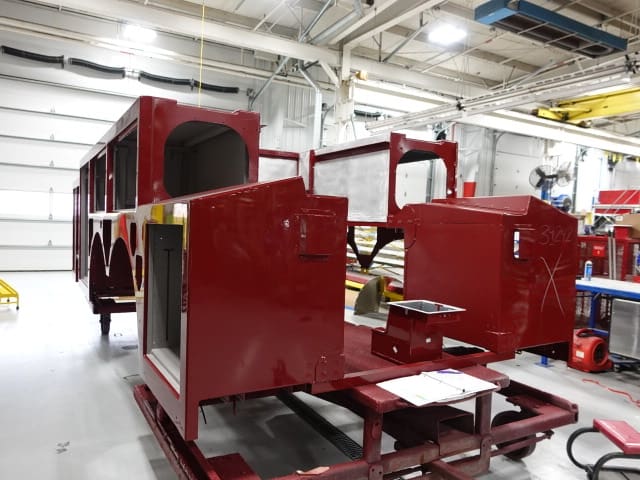

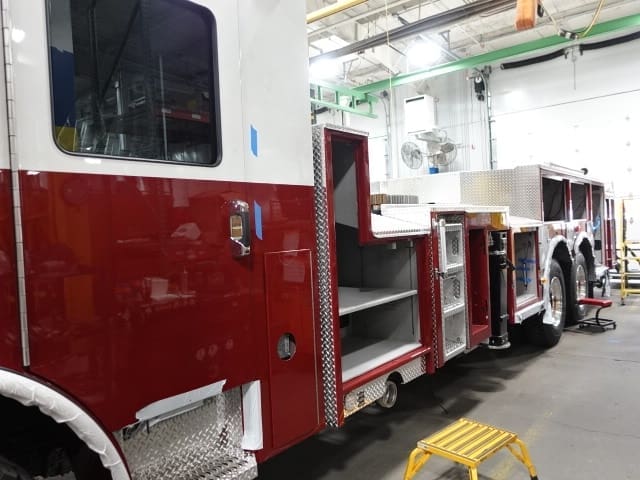

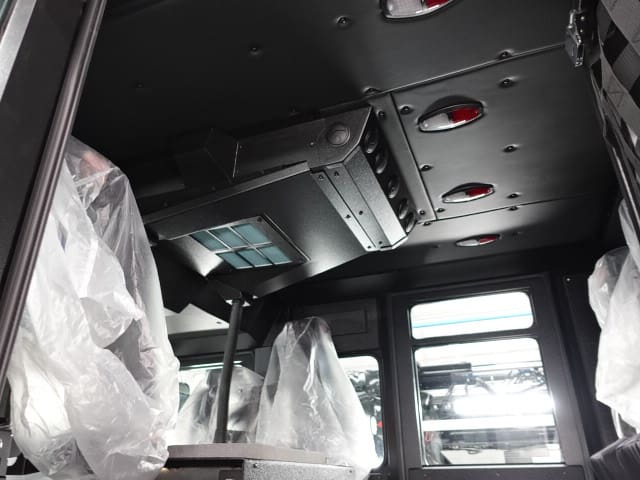

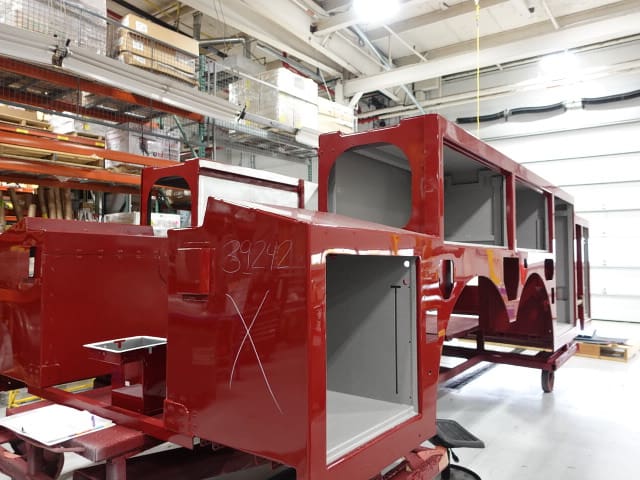

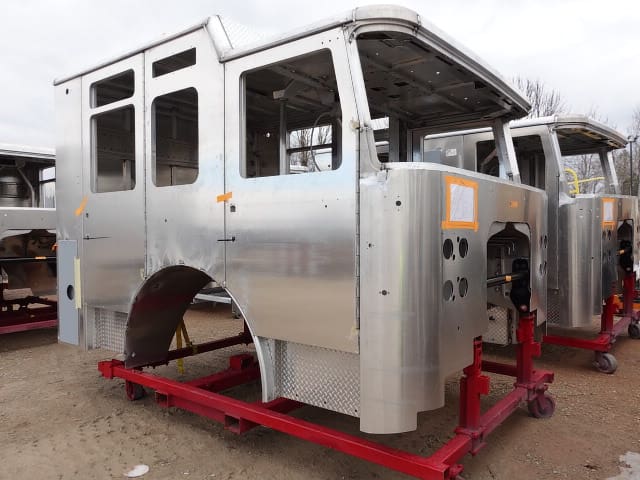

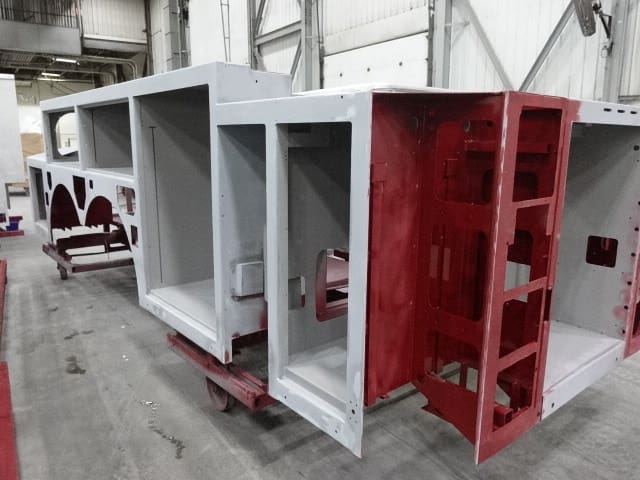

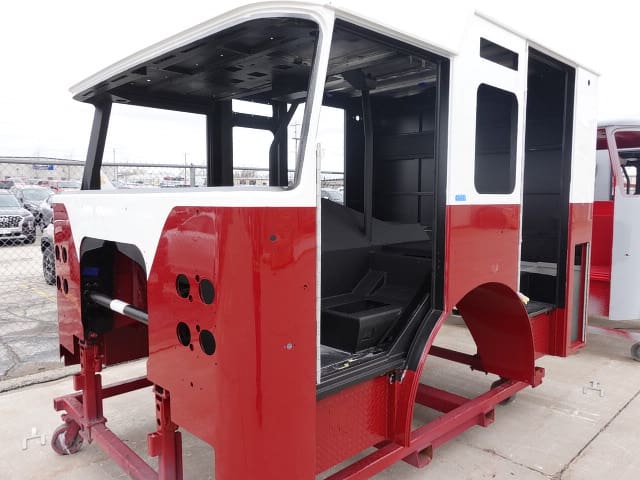

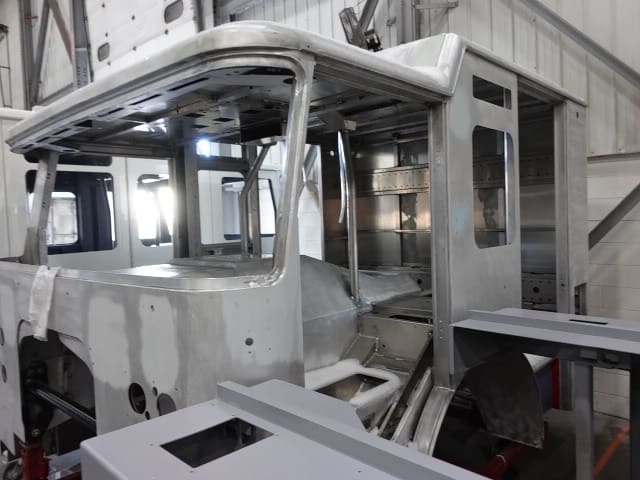

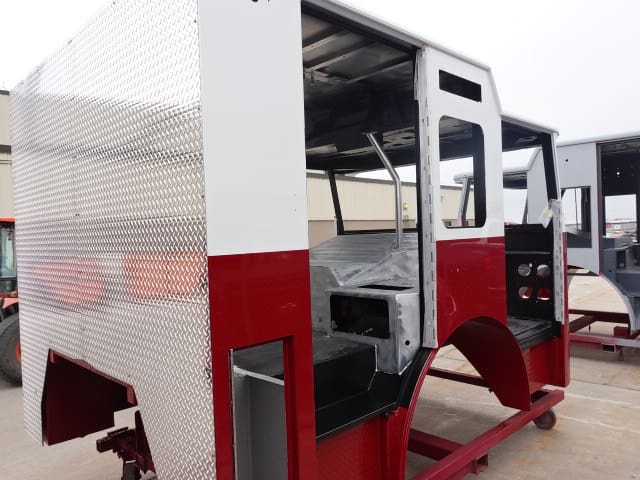

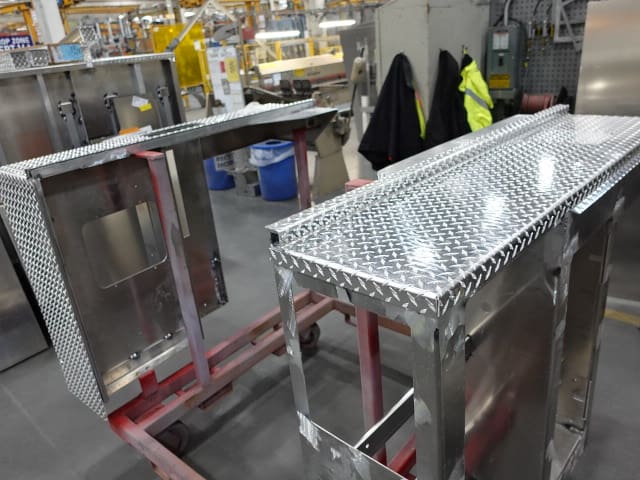

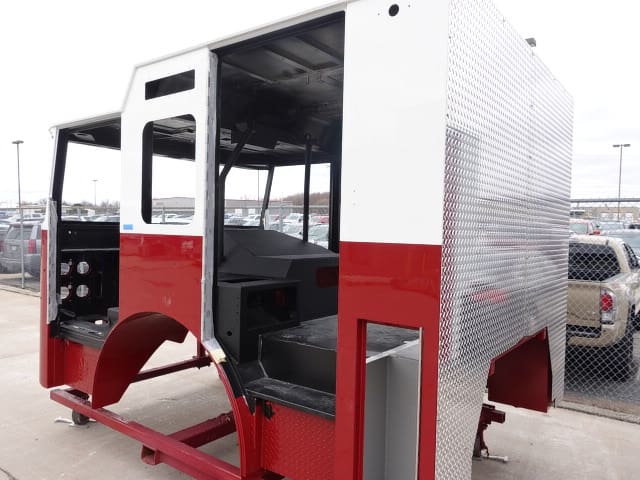

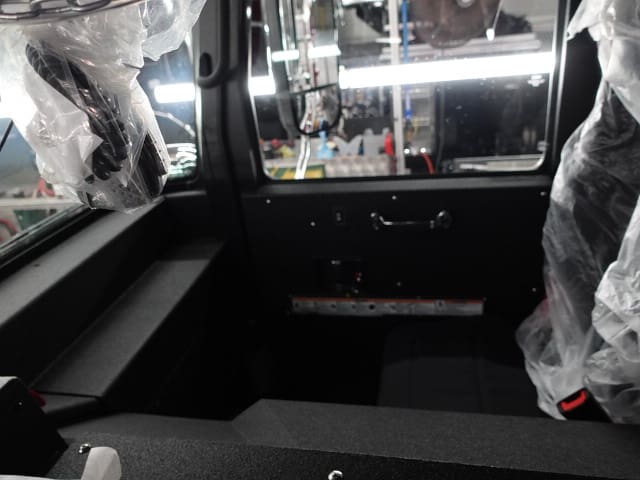

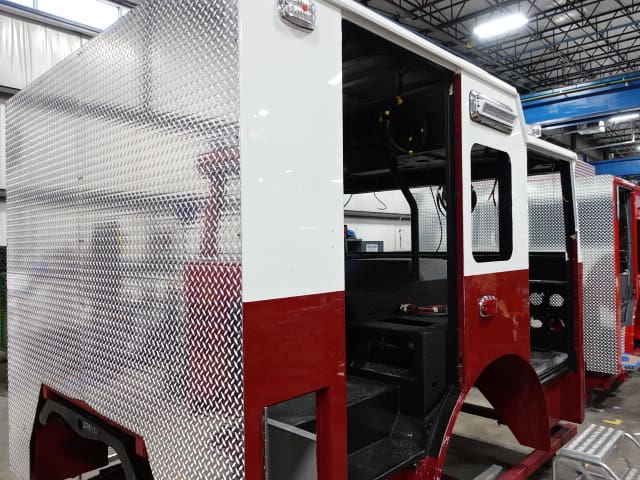

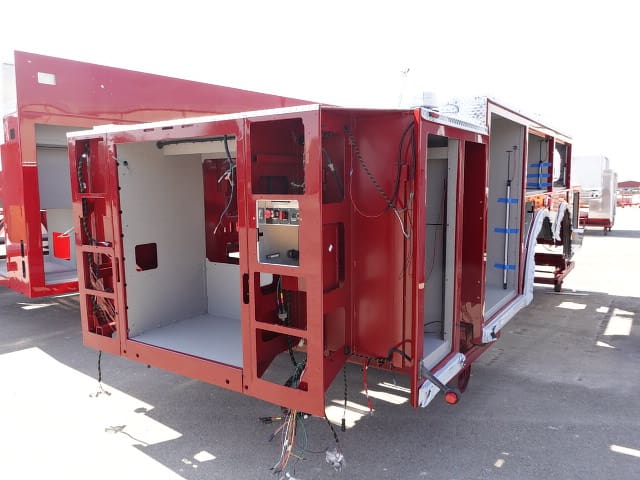

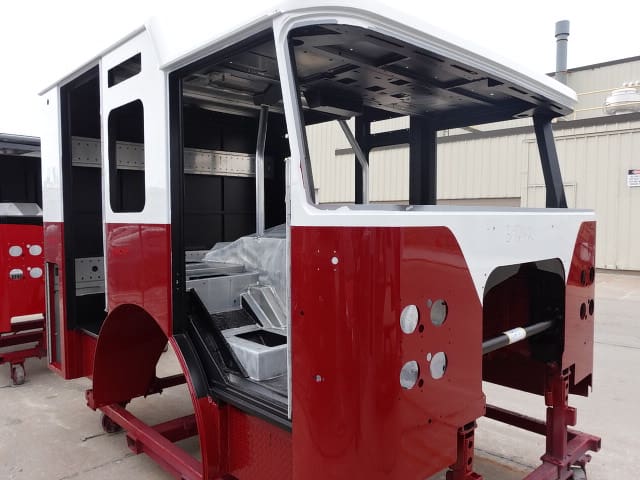

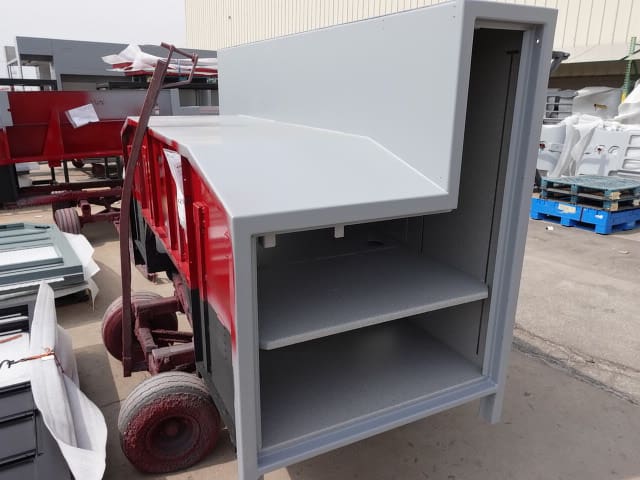

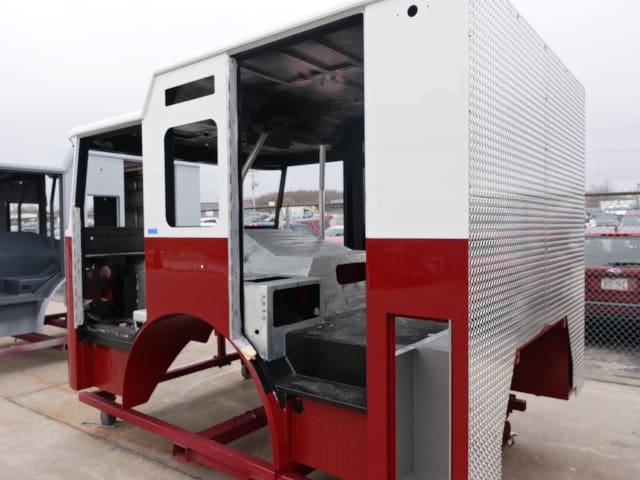

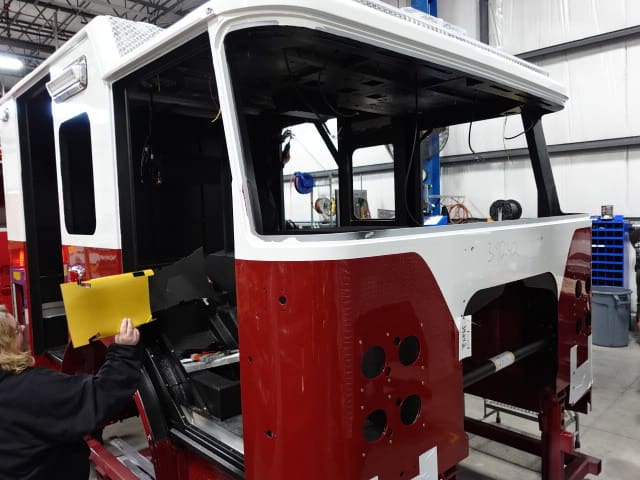

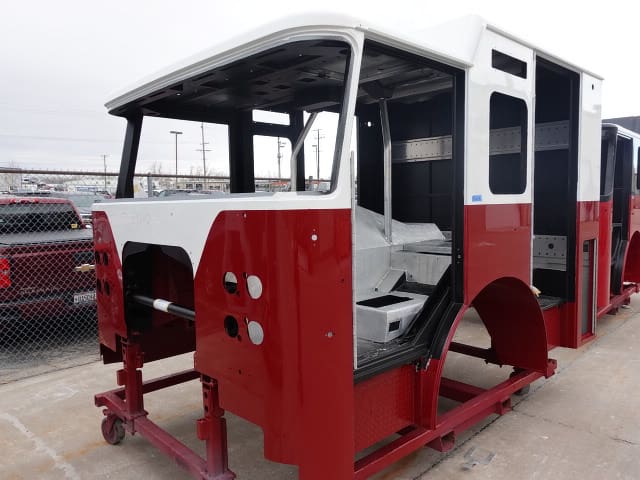

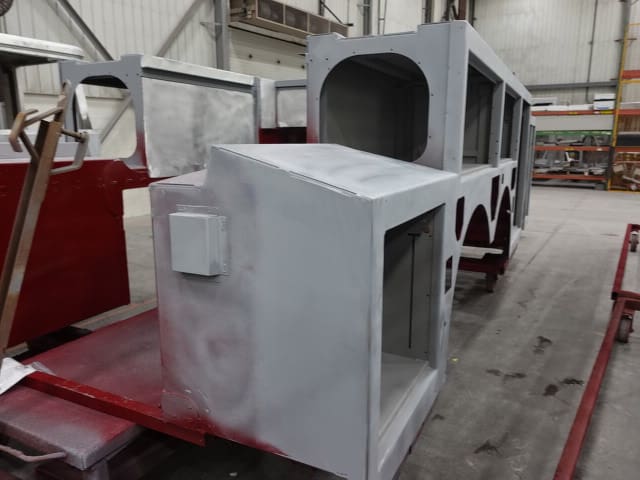

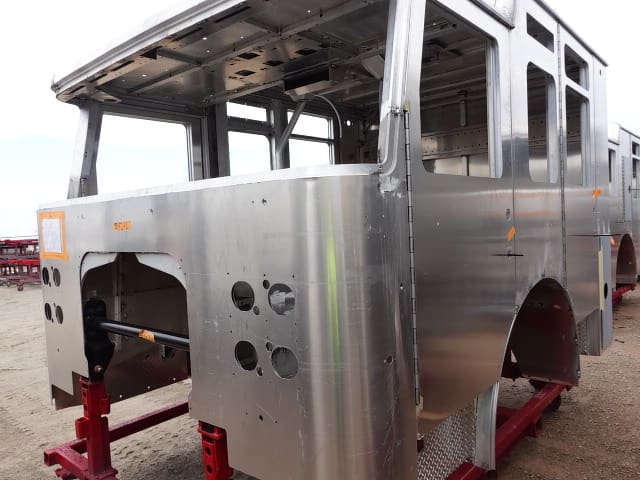

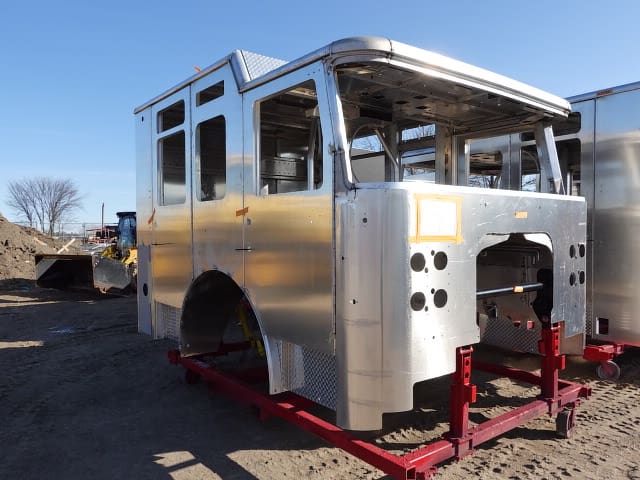

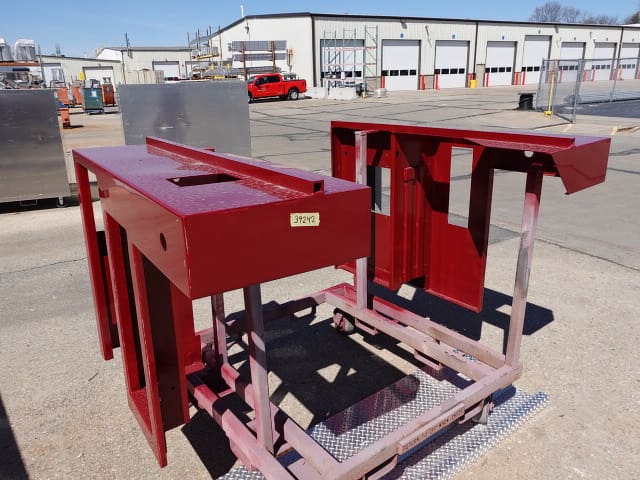

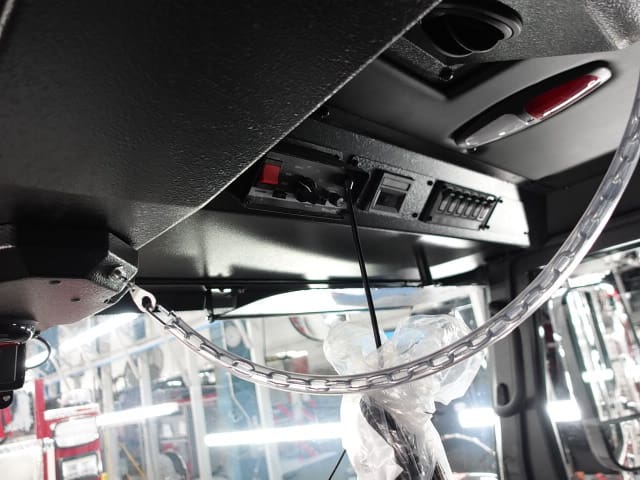

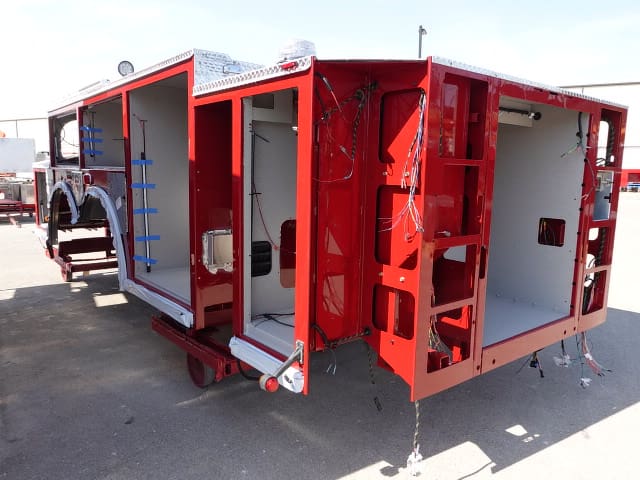

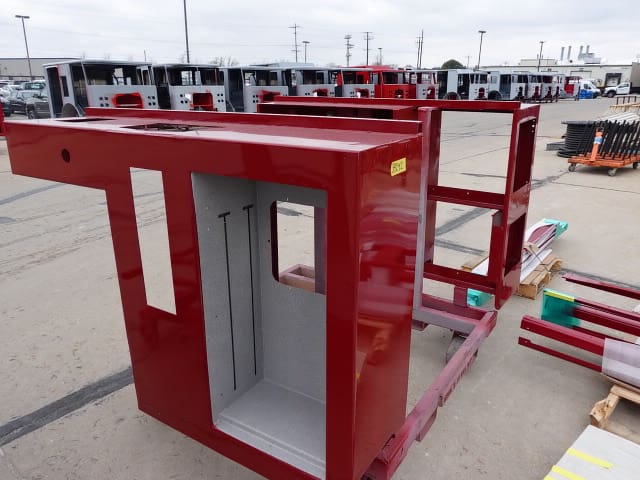

In this report, the cab completed initial assembly and was installed on the frame, the transverse completed fabrication and began the paint process, the torque box continued initial assembly, the turntable module was staged, and the rear body module completed initial assembly.

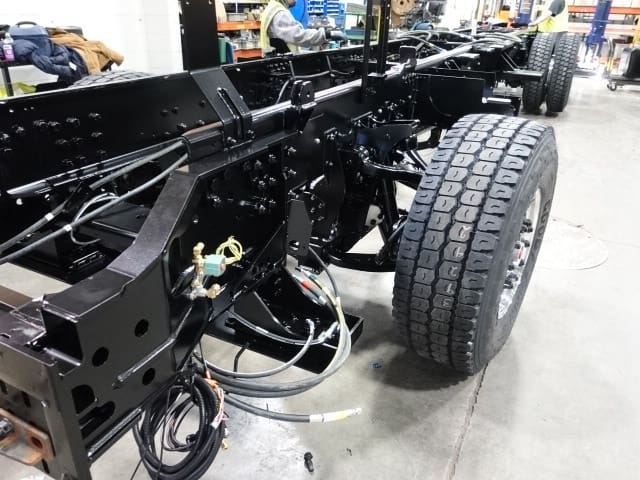

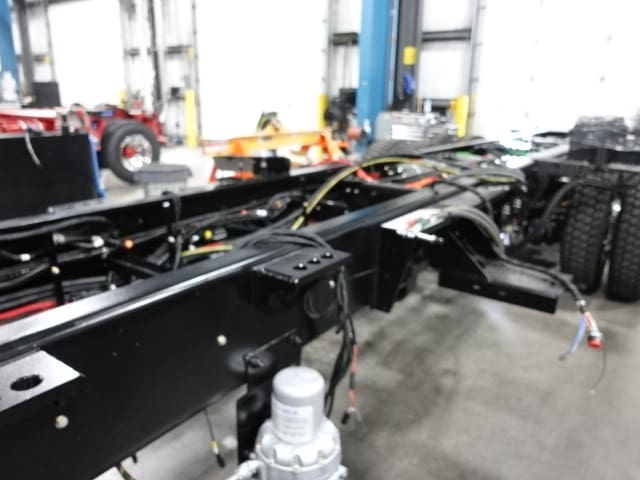

04-11-25

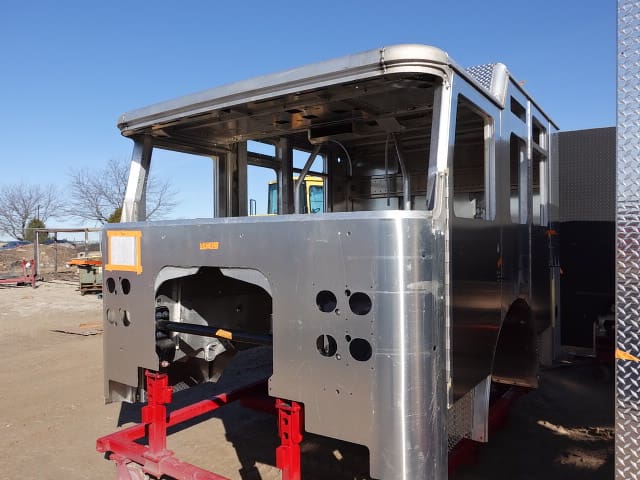

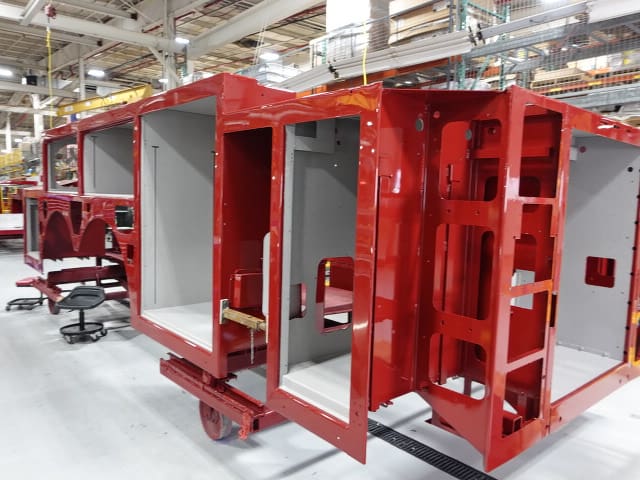

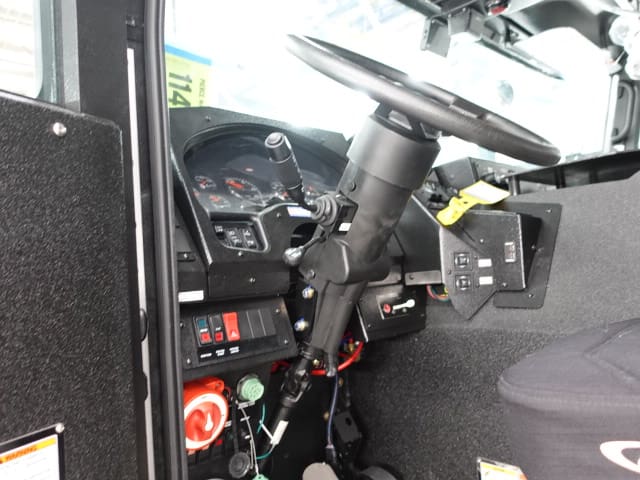

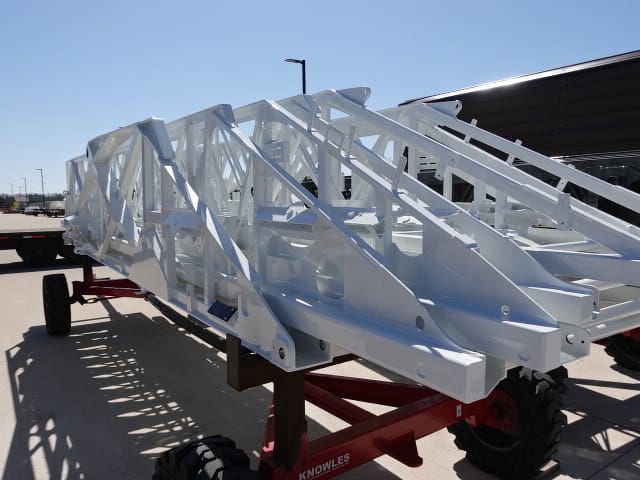

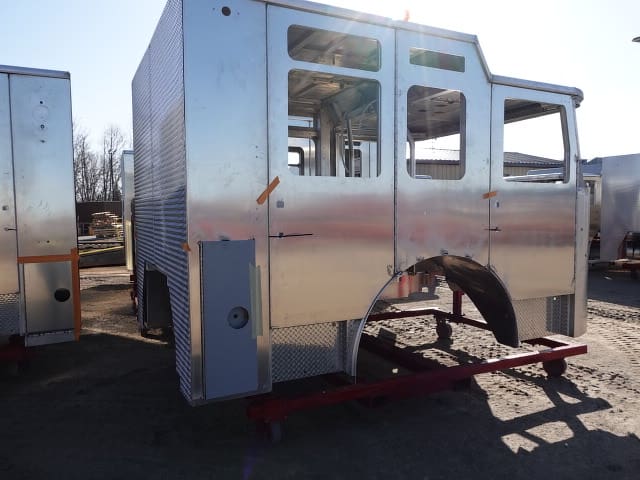

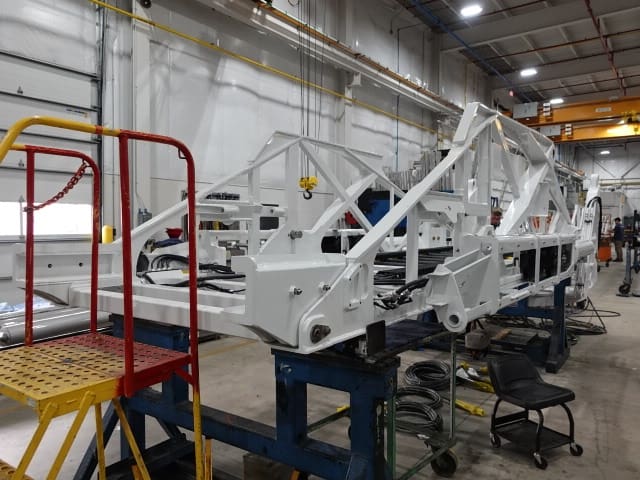

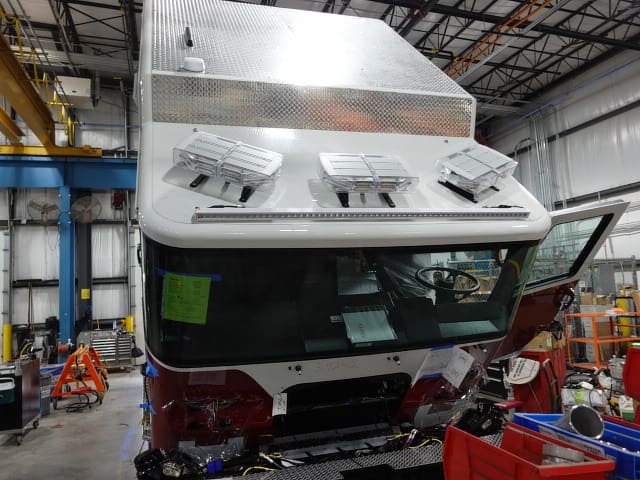

In this report, the cab began initial assembly, the frame build continued, the transverse continued fabrication, the torque box began initial assembly, the turntable module completed paint, and the rear body module completed paint and began initial assembly.
04-04-25

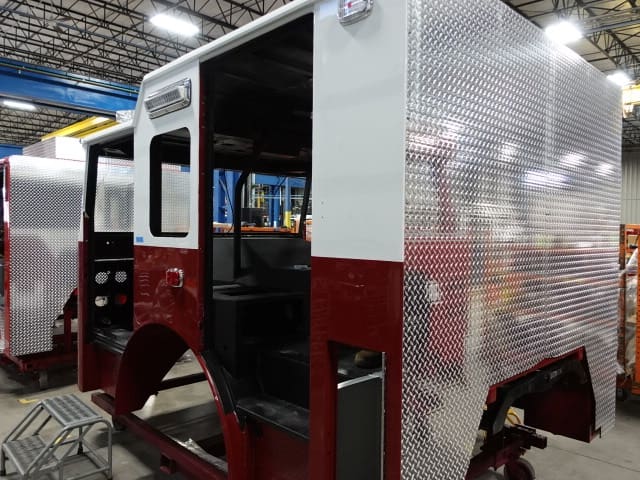

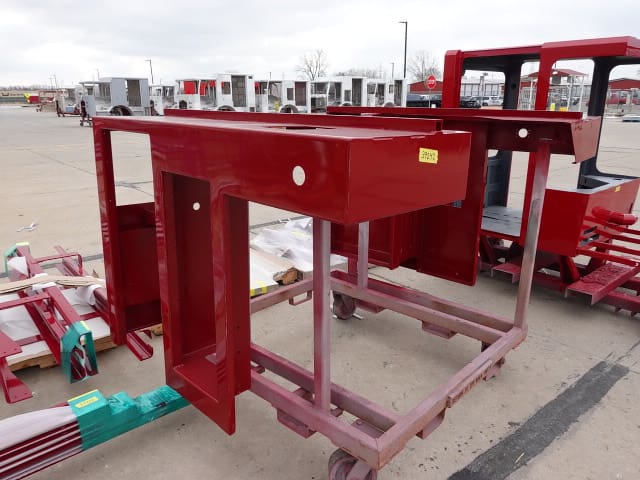

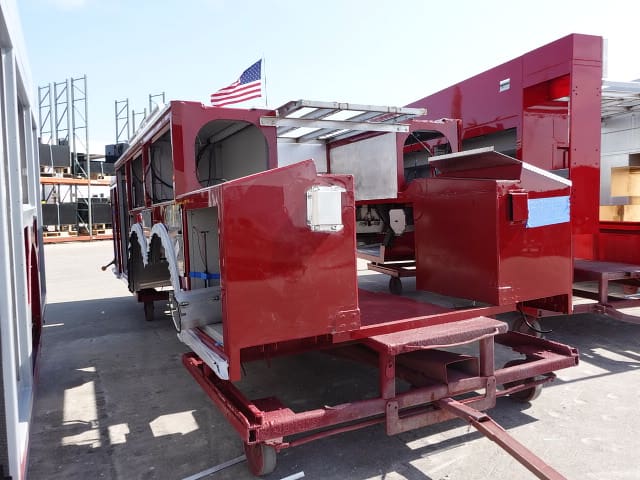

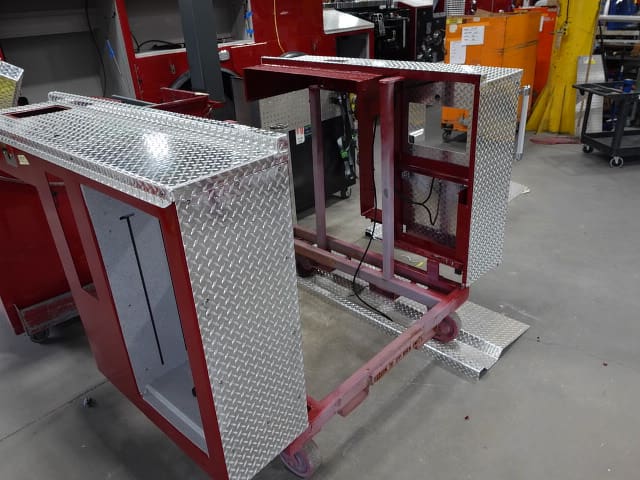

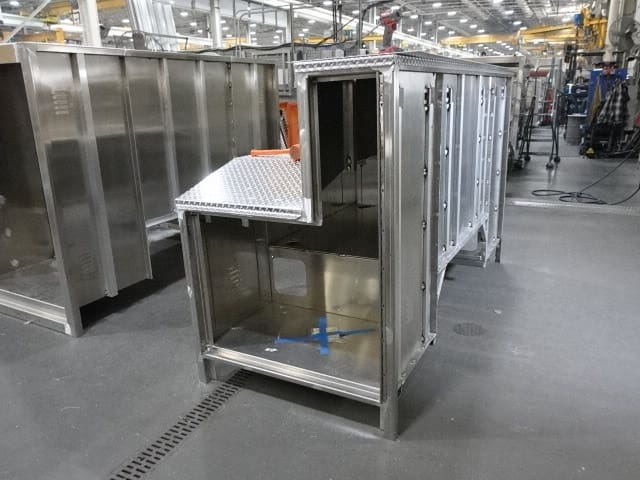

In this report, the cab was staged, the frame build continued, the transverse compartment began fabrication, the torque box arrived and was staged, the turntable module was unavailable for photos, and the rear body module completed fabrication and began the paint process.
03-28-25

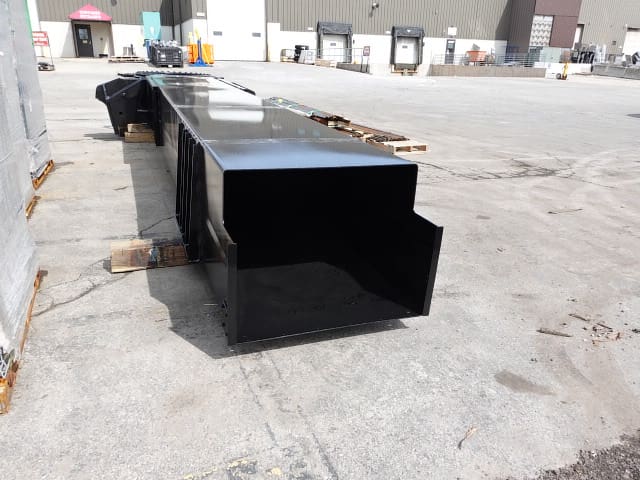

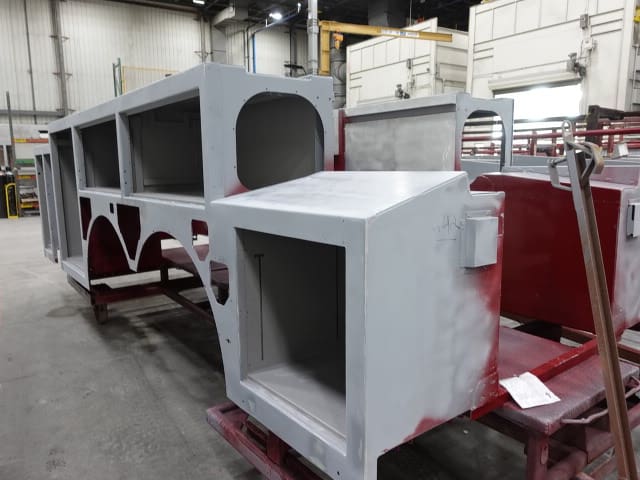

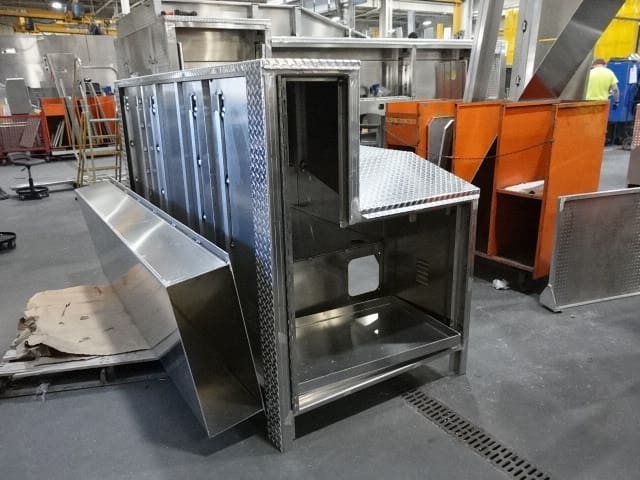

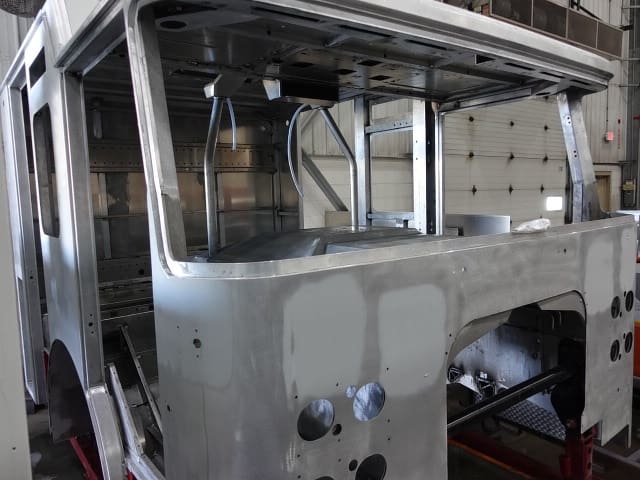

In this report, the cab completed the paint process, the frame build began, the turntable module began fabrication, and the rear body module was unavailable for photos.
03-21-25

In this report, the cab began the paint process while the rear body module began fabrication.
