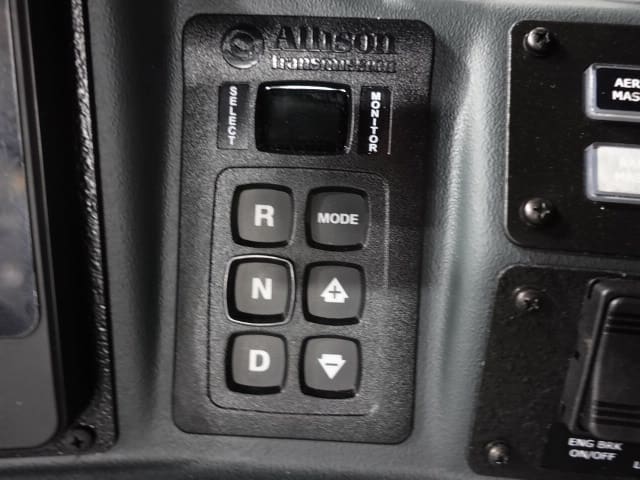

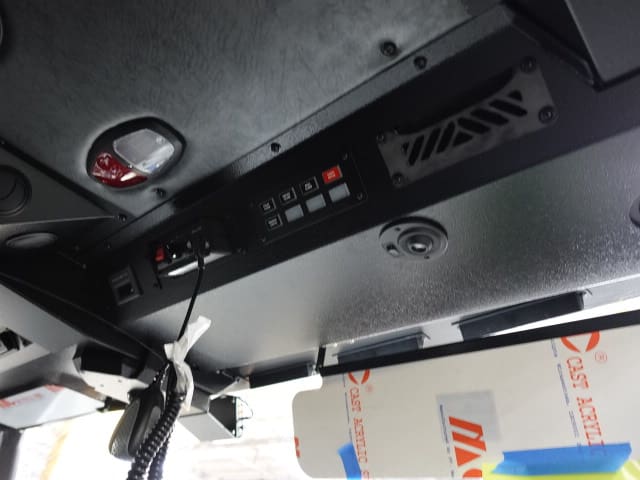

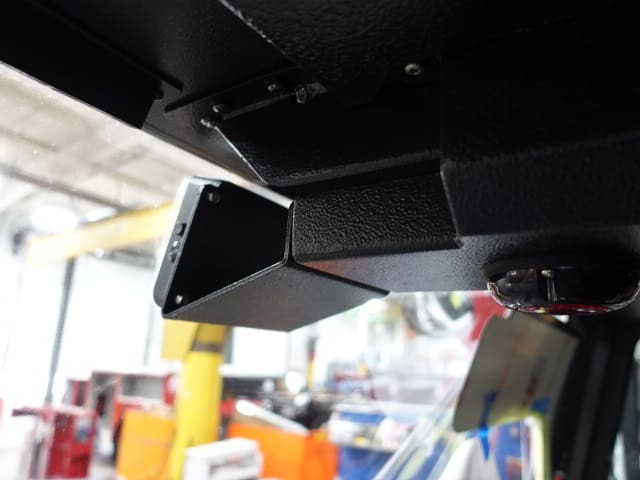

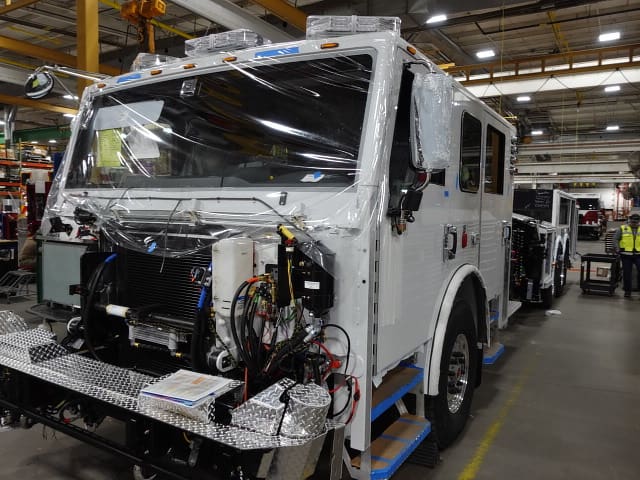

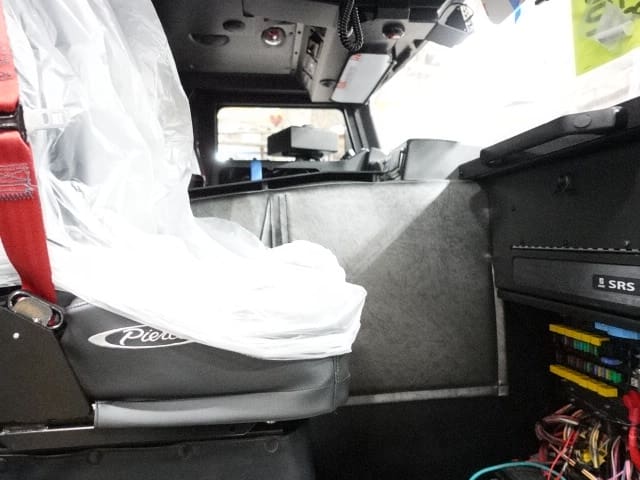

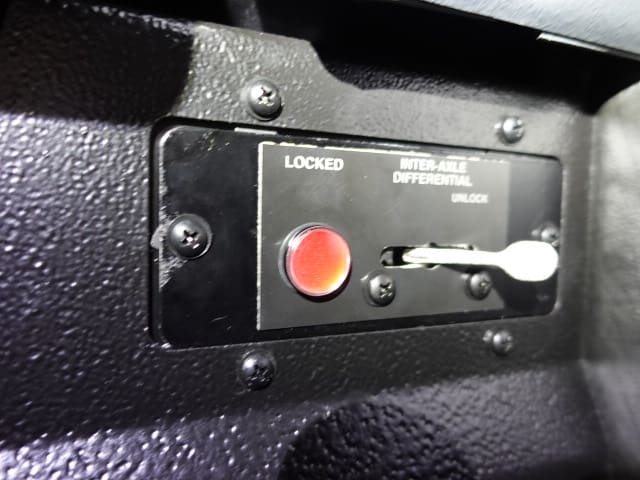

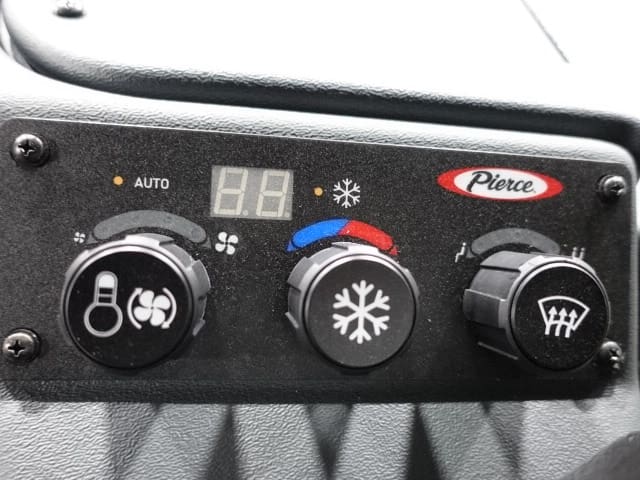

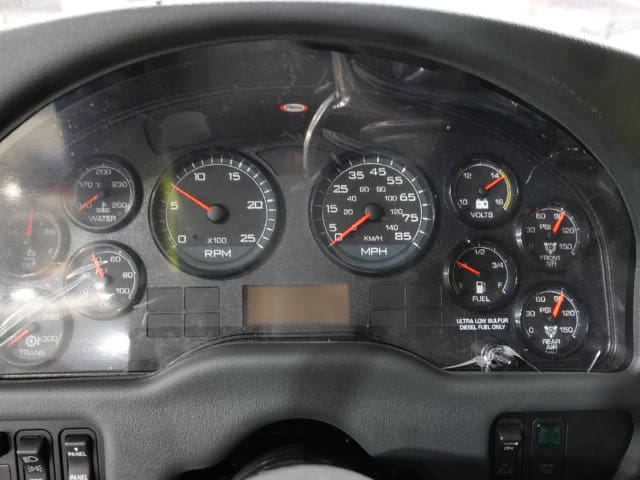

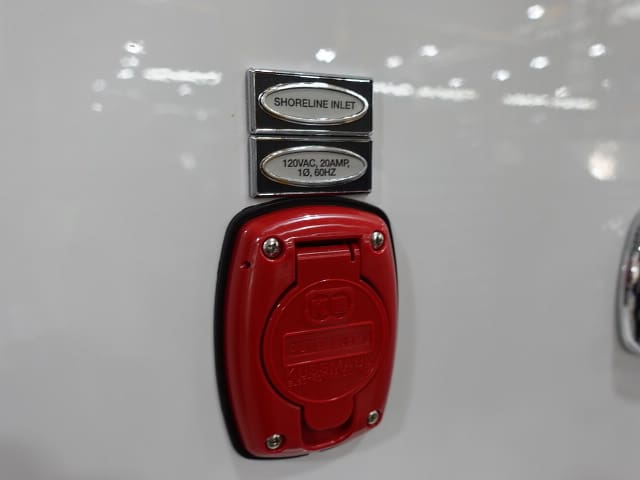

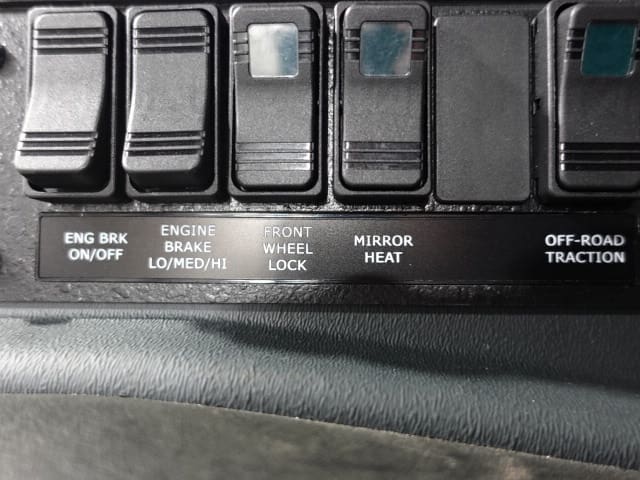

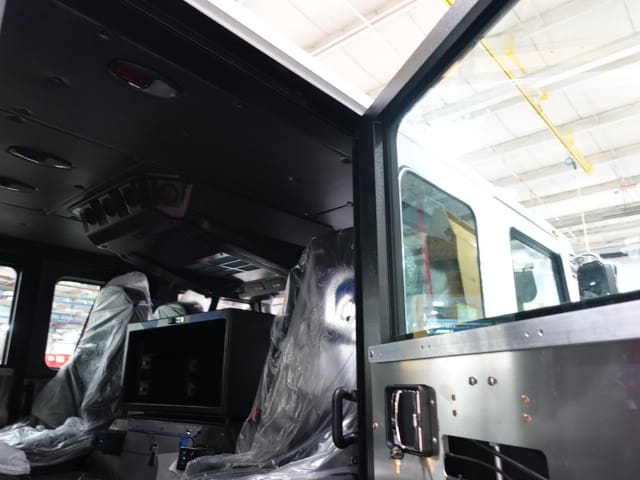

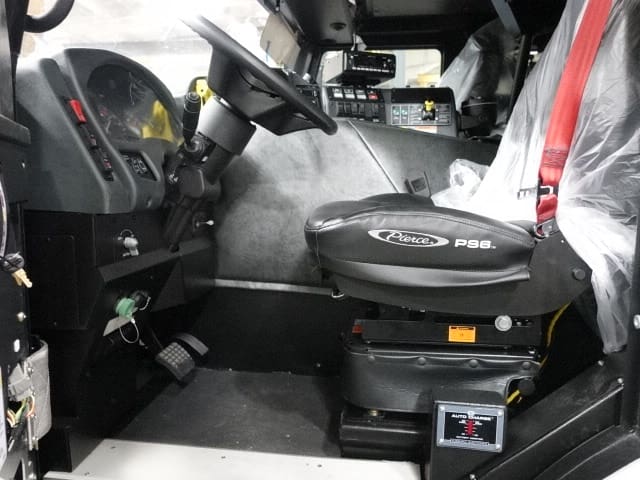

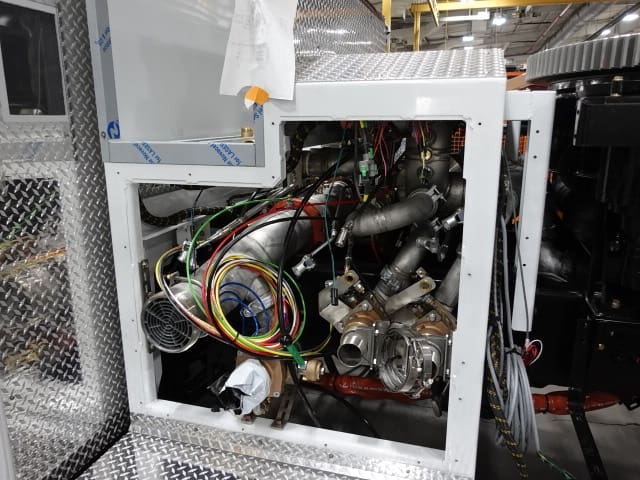

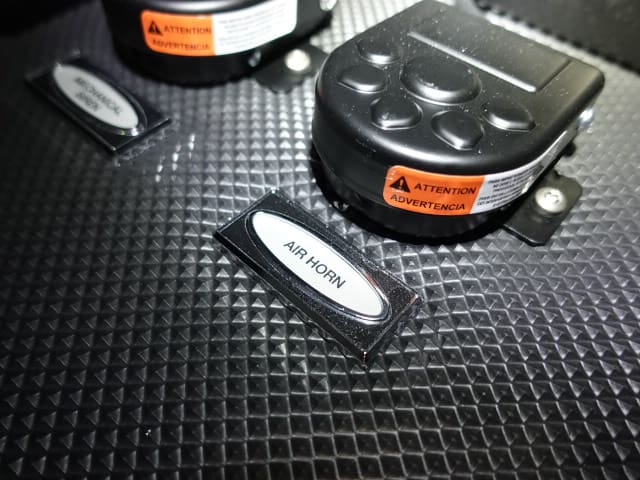

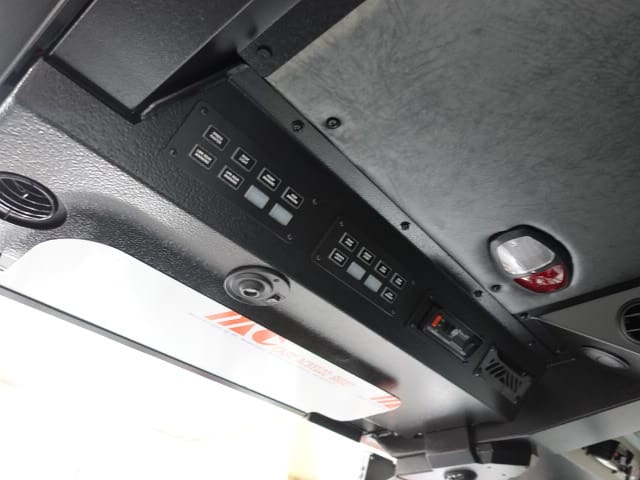

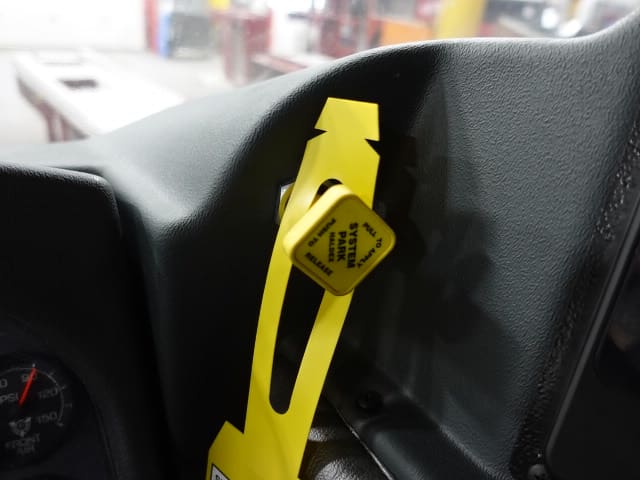

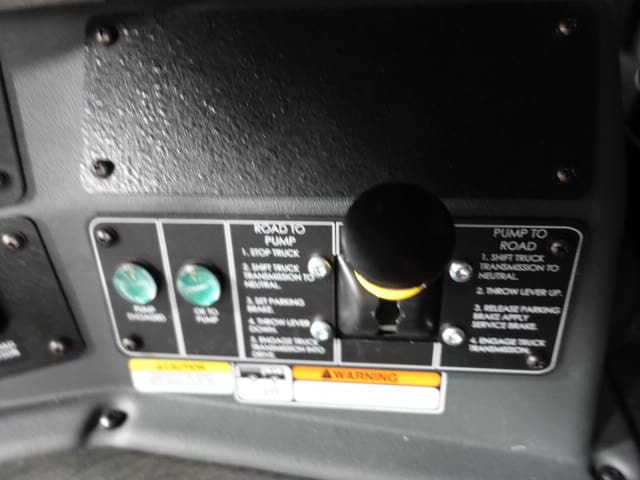

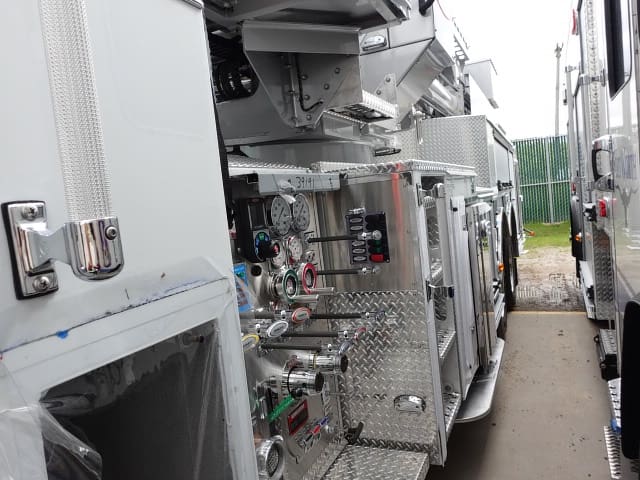

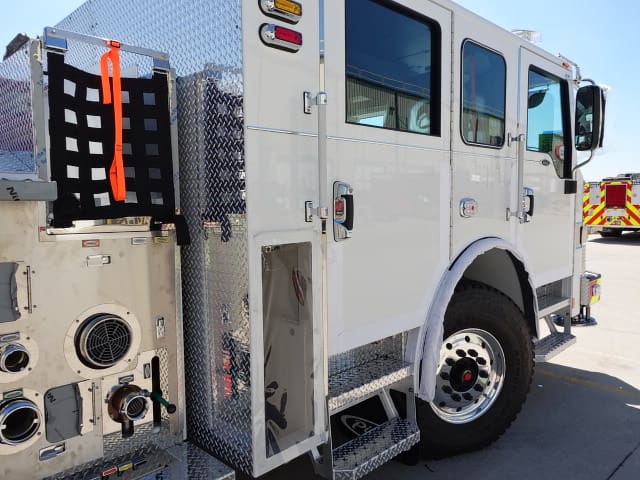

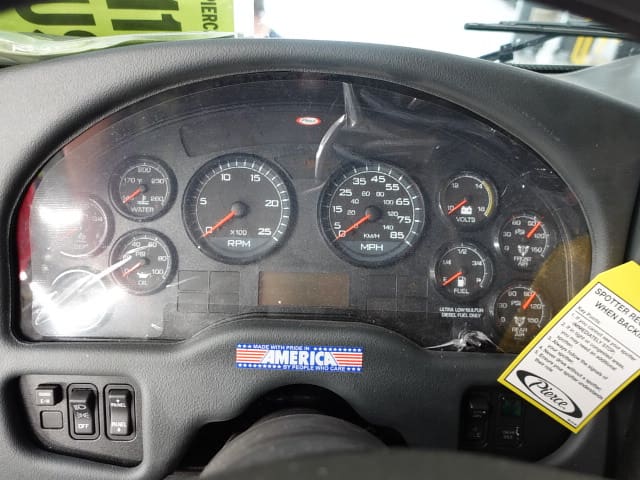

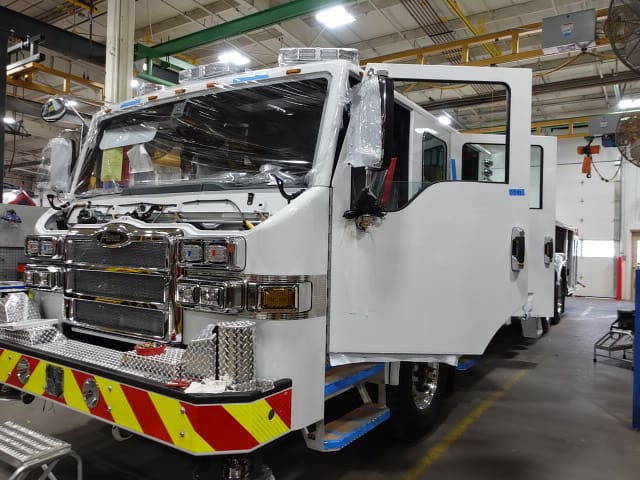

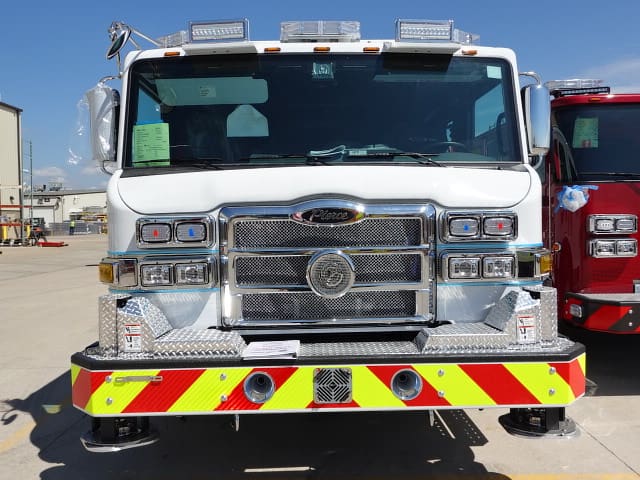

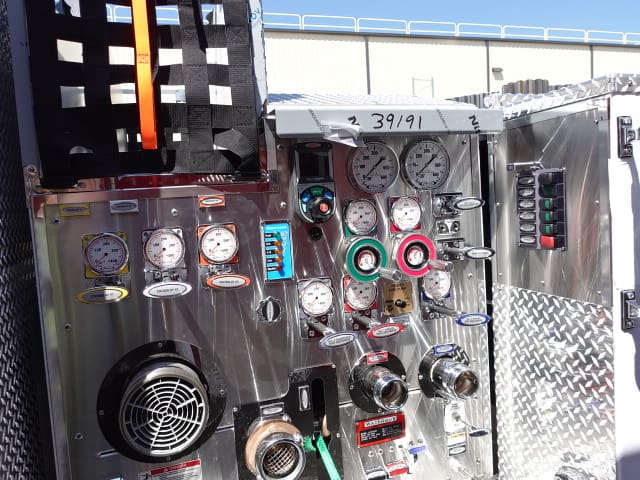

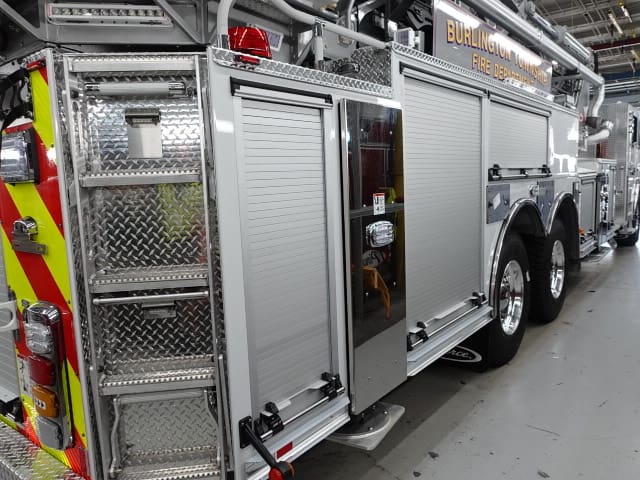

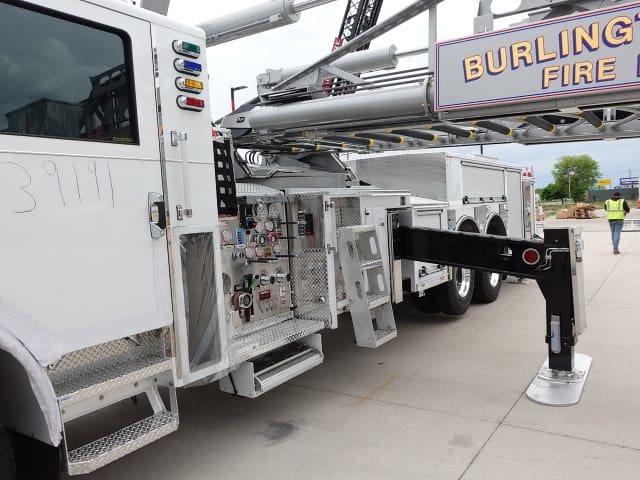

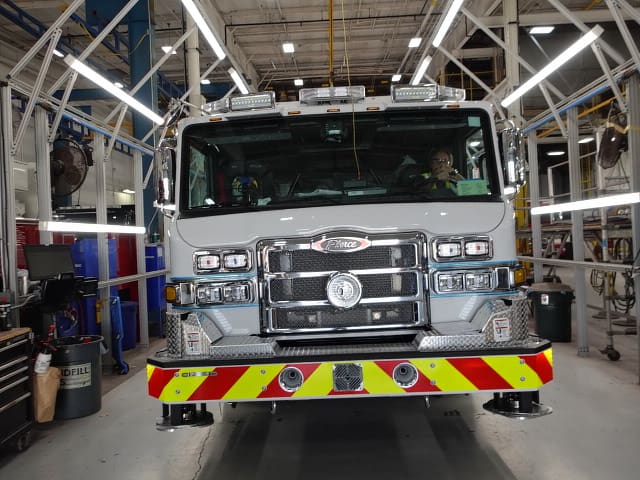

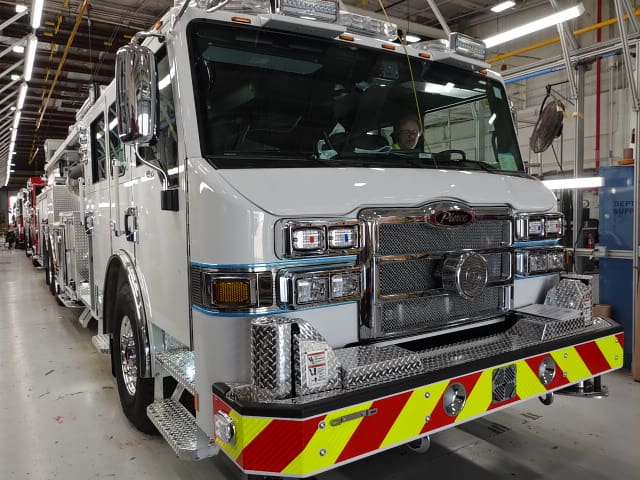

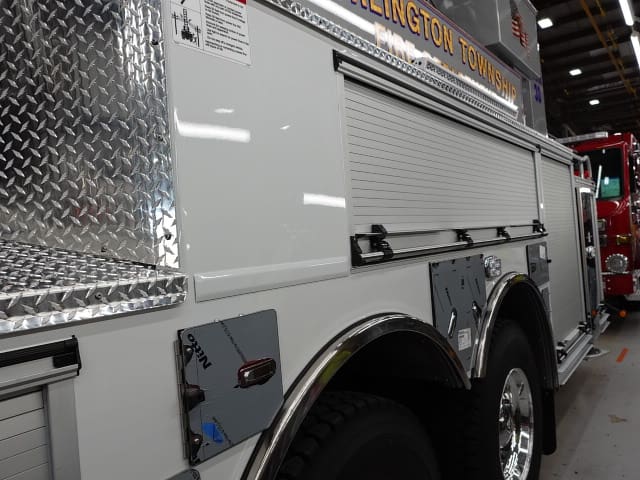

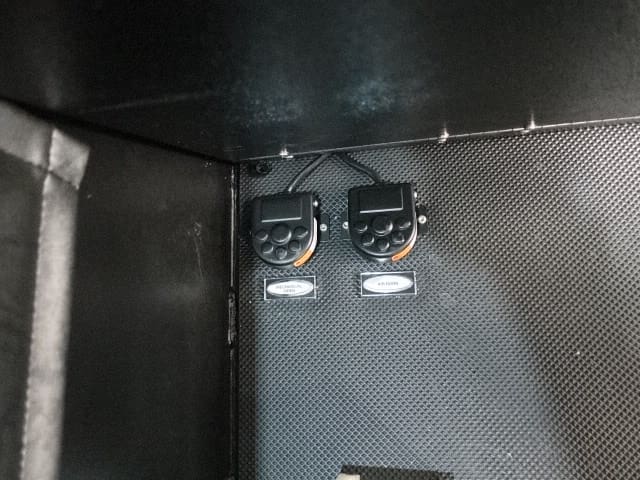

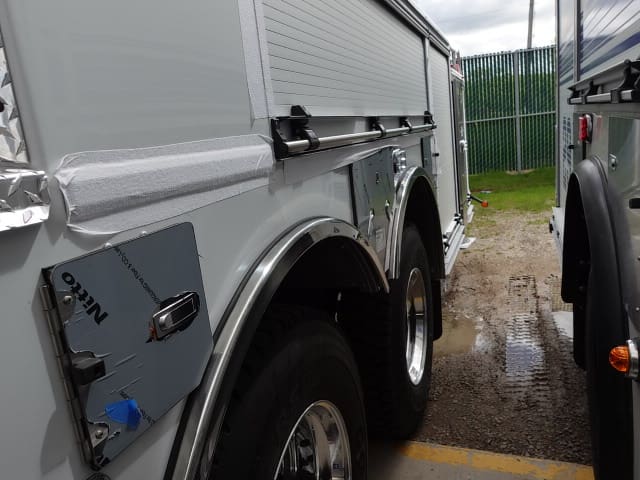

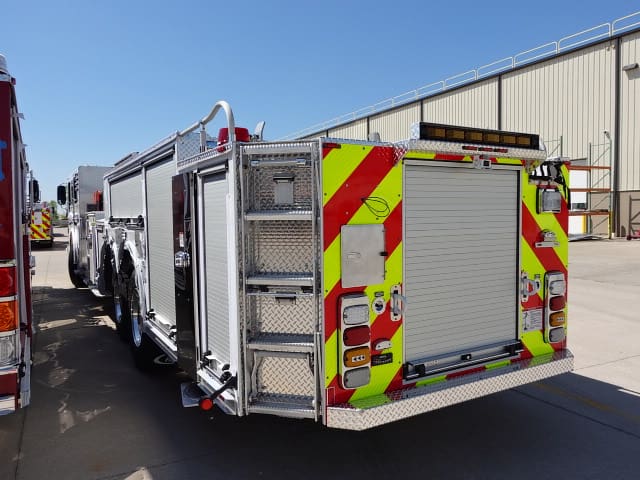

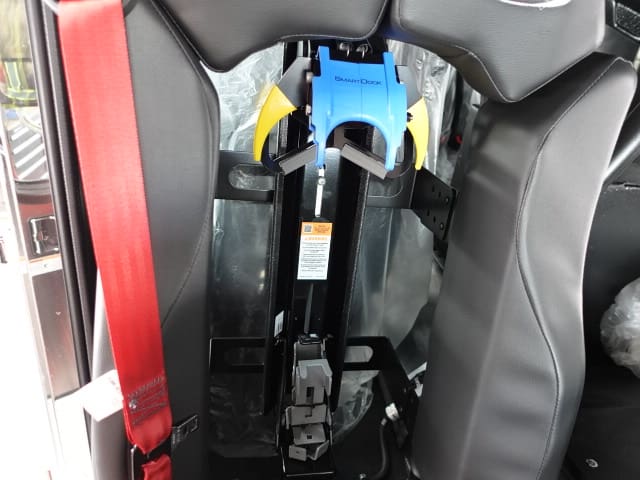

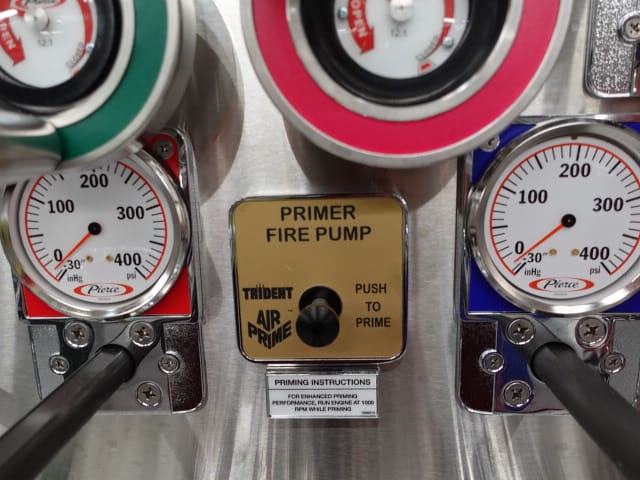

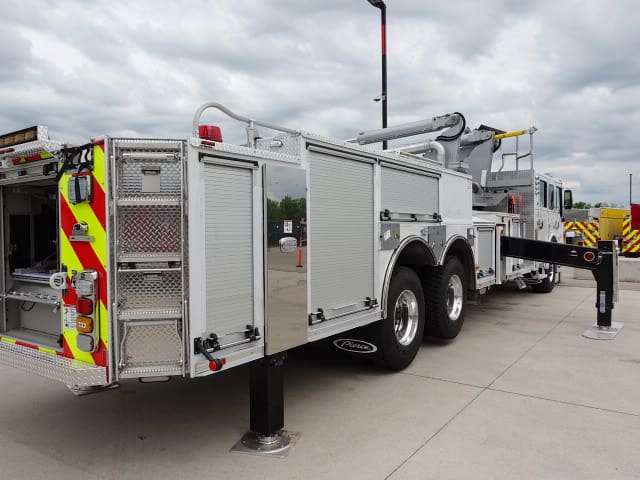

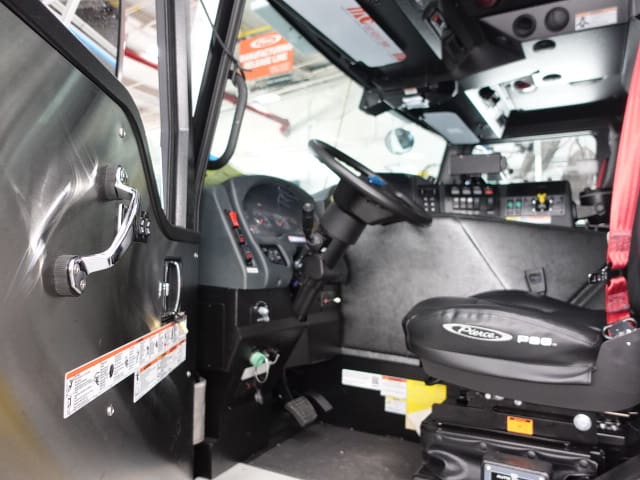

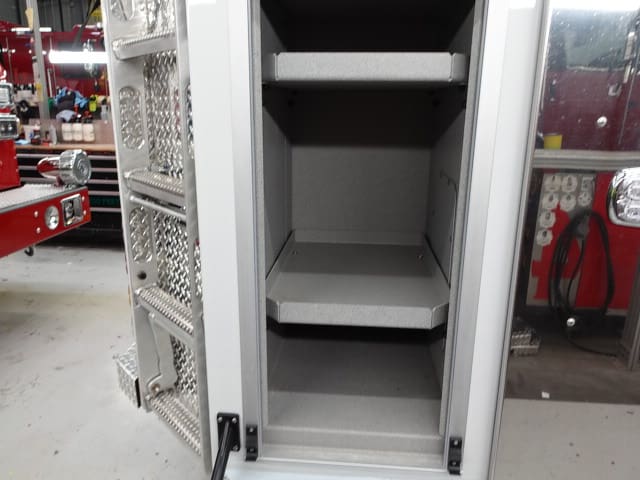

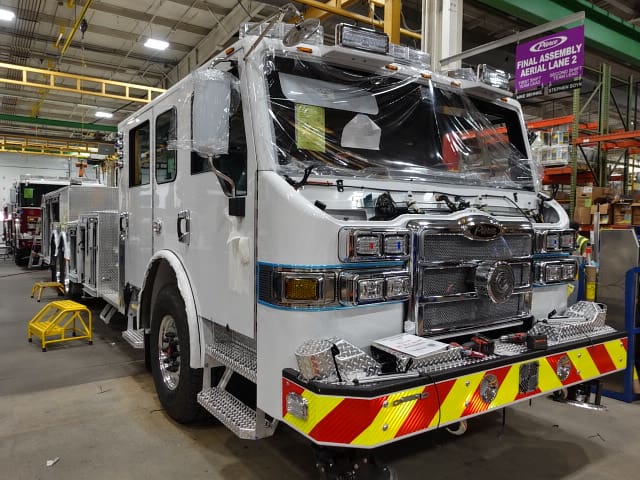

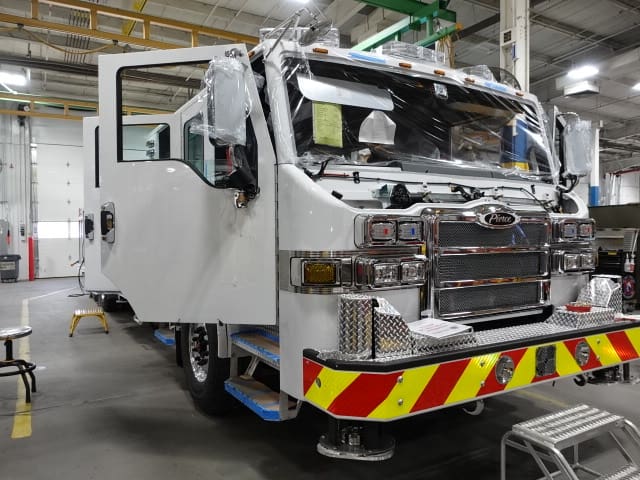

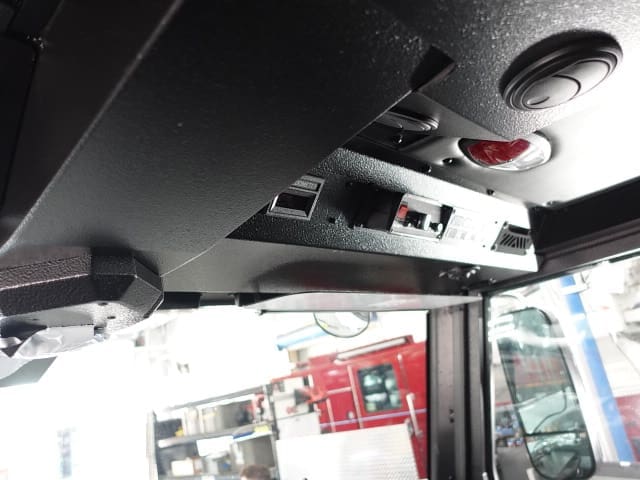

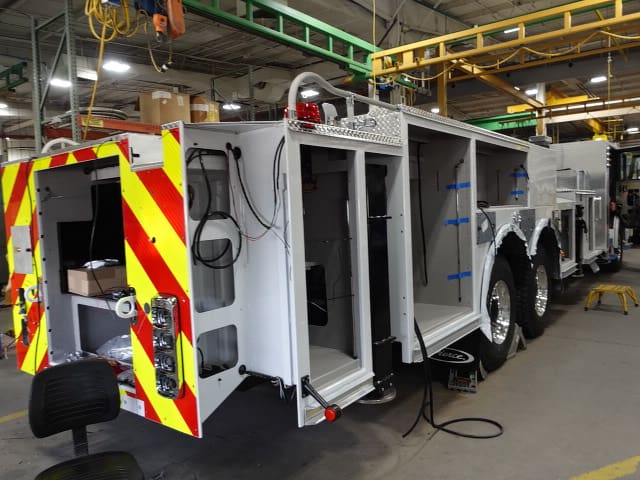

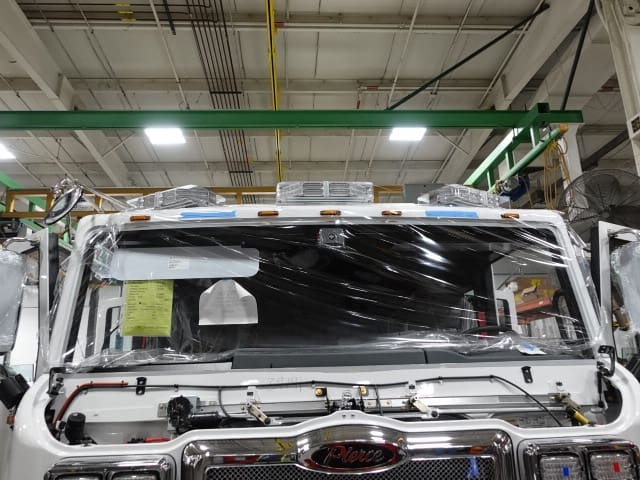

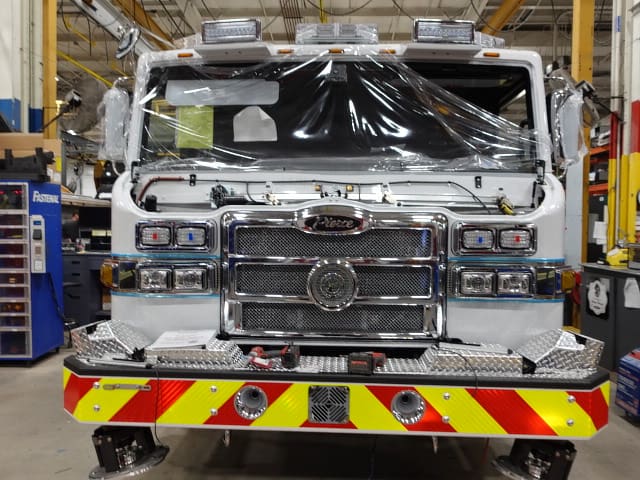

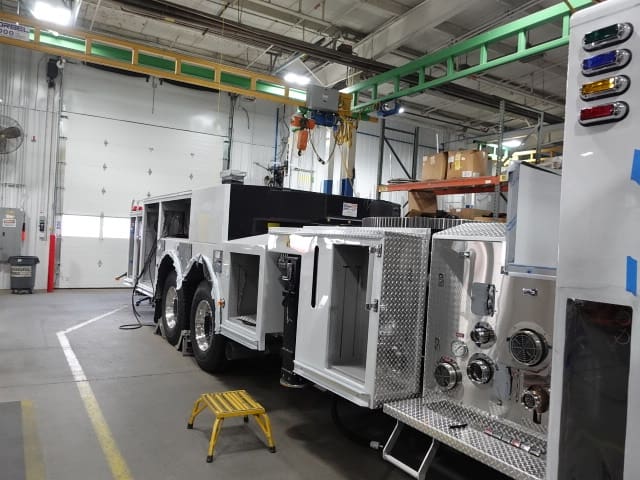

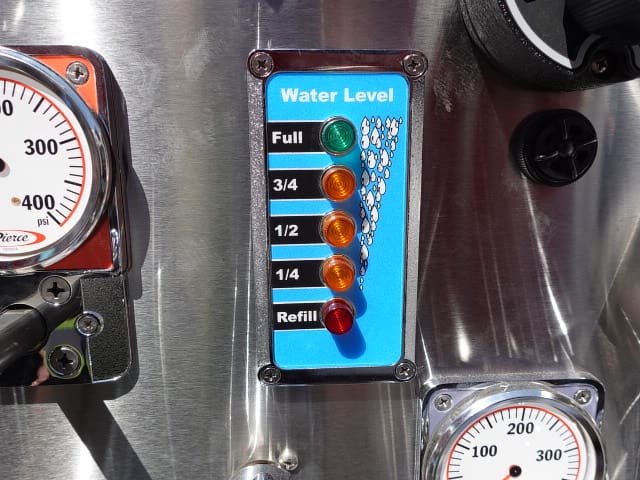

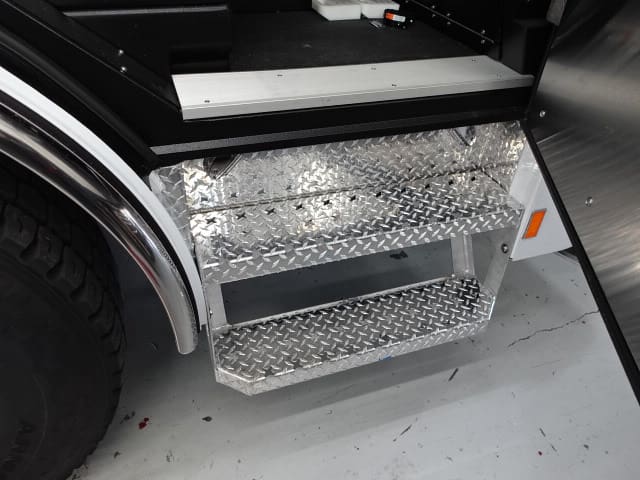

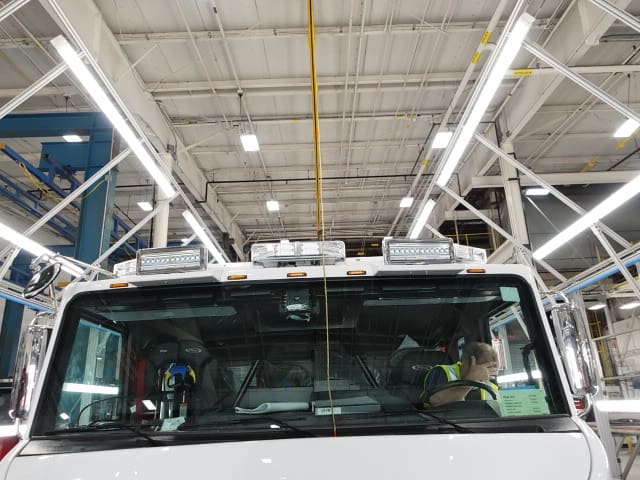

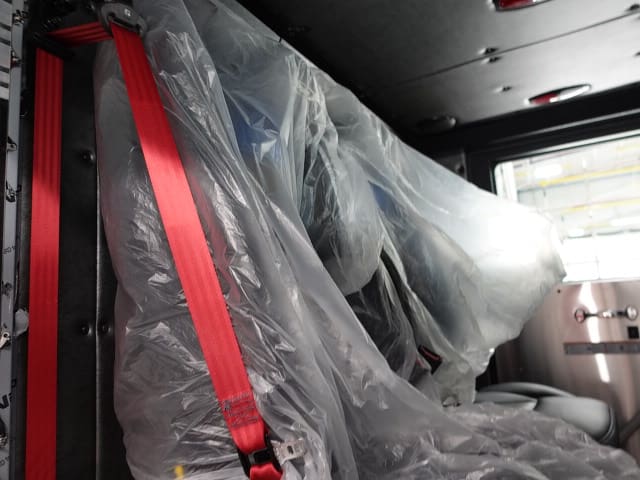

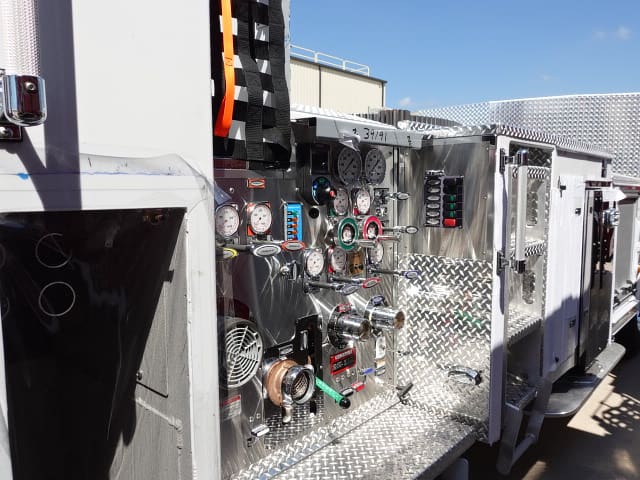

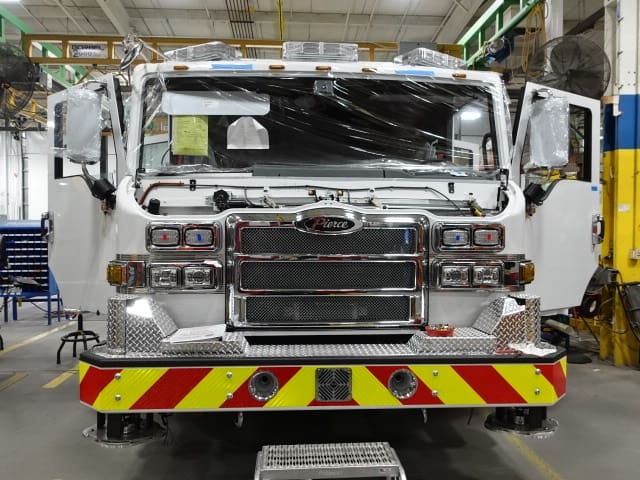

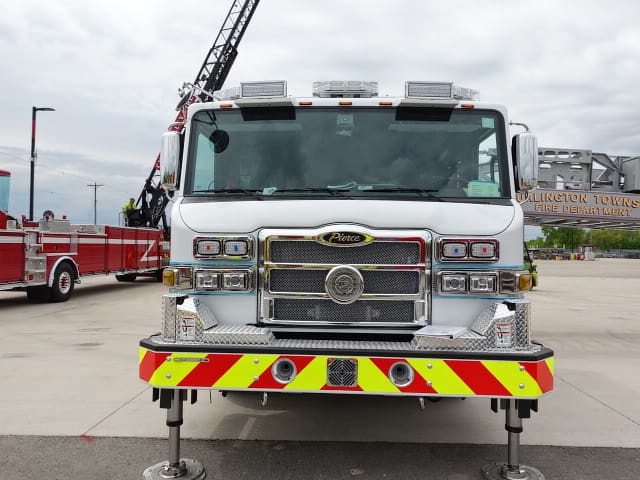

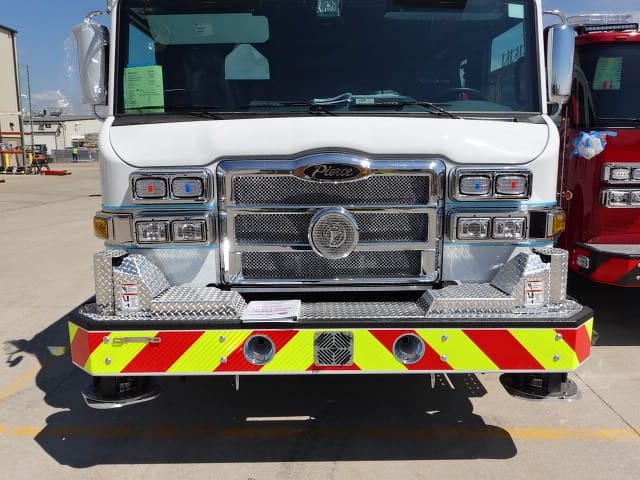

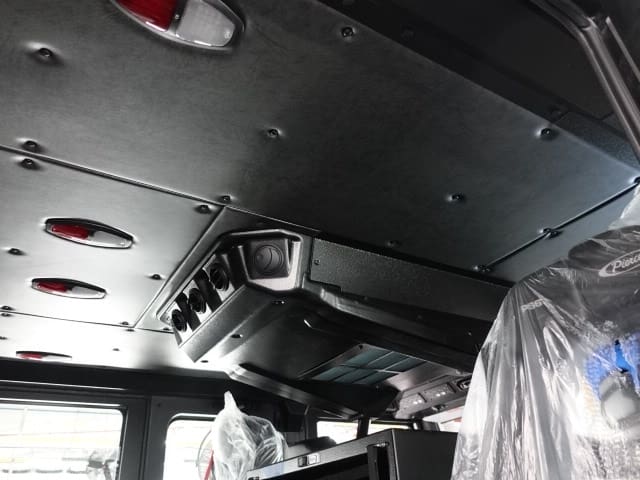

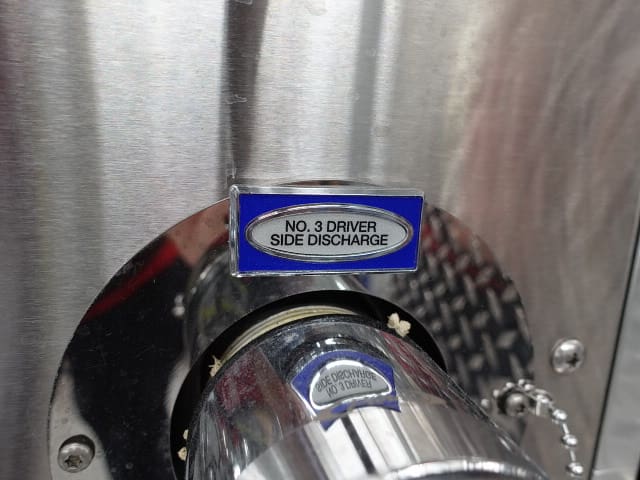

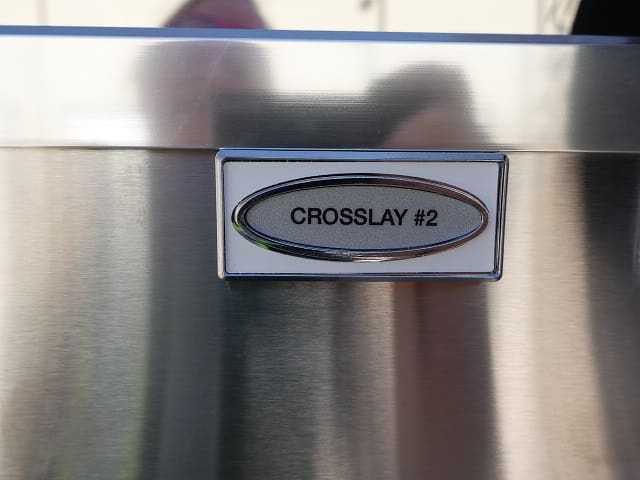

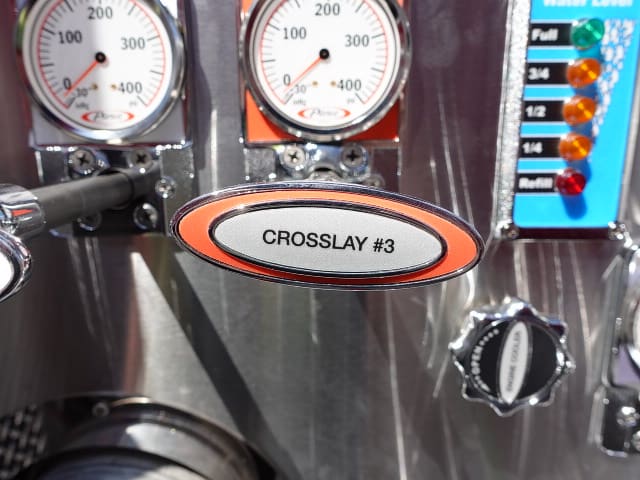

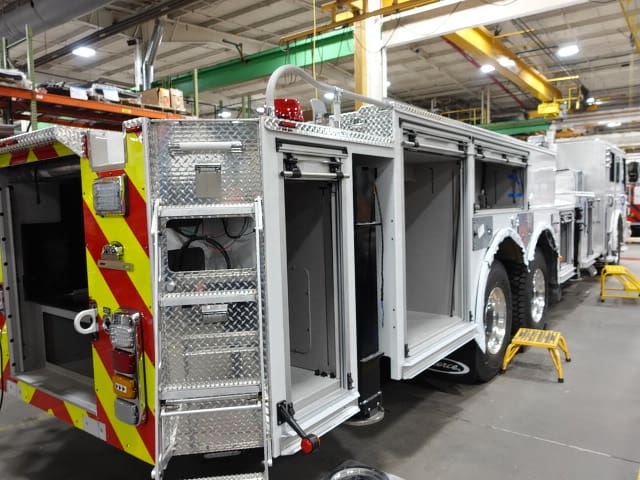

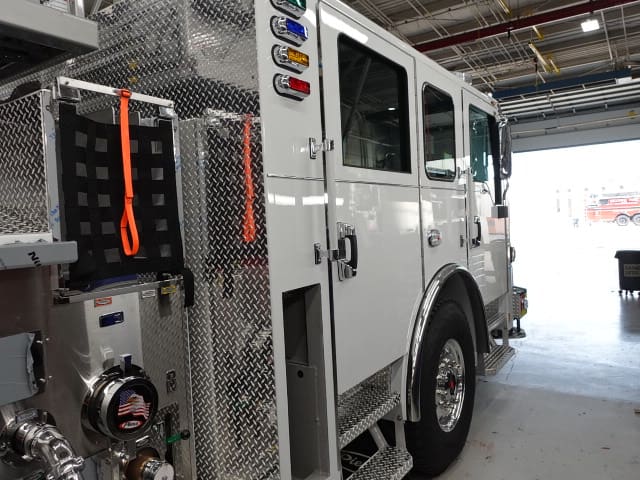

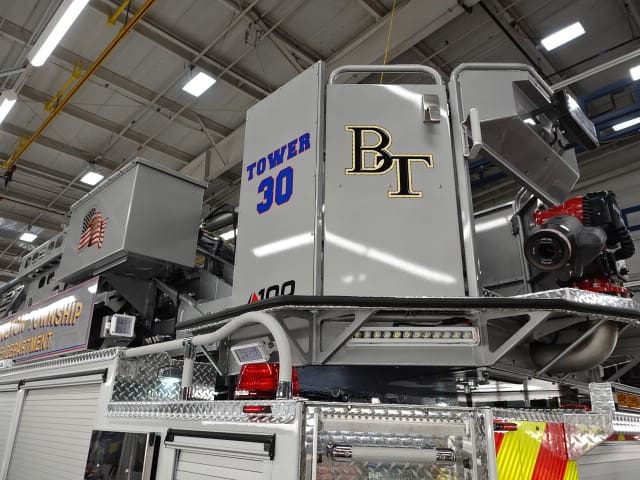

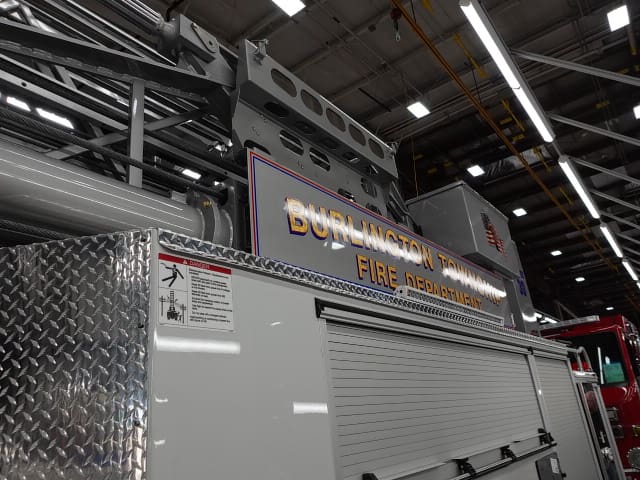

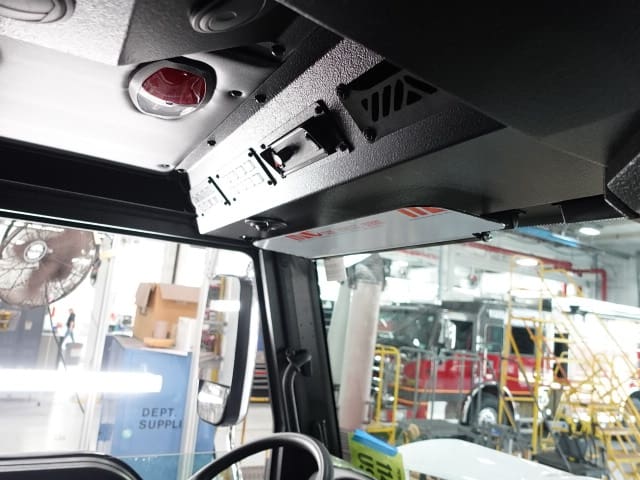

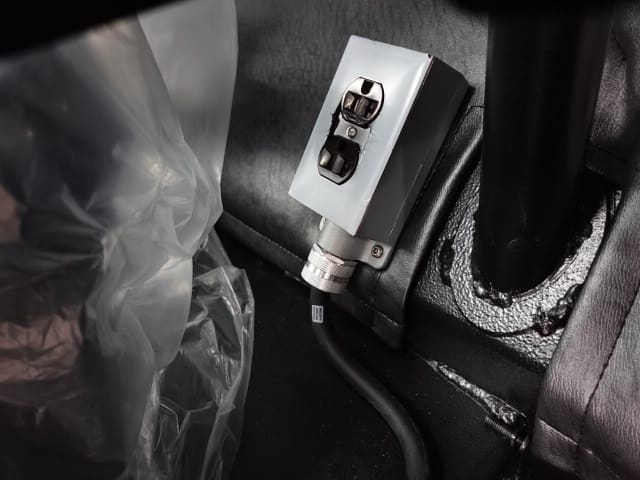

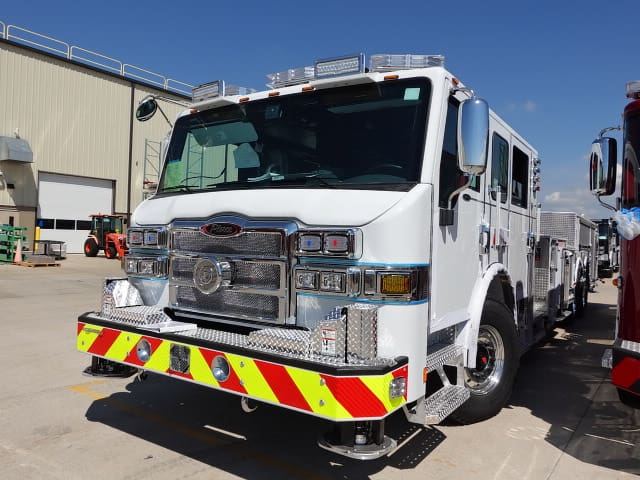

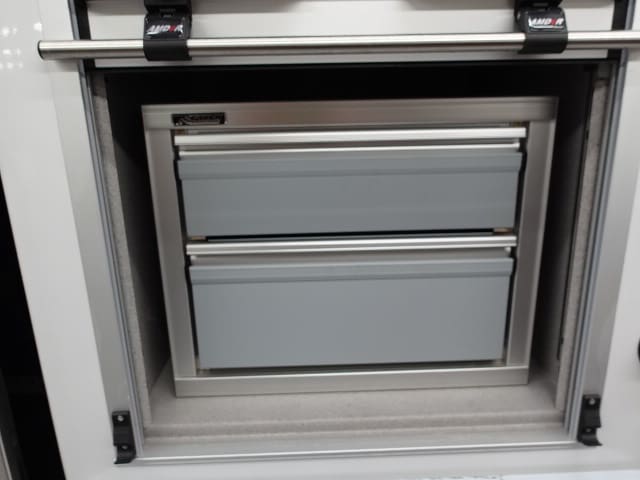

06-06-25

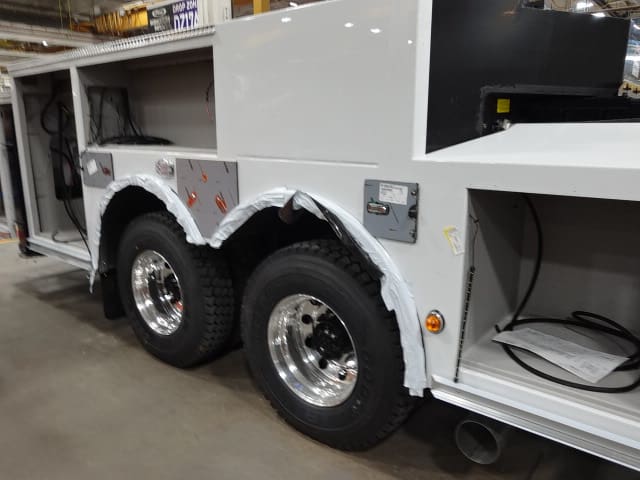

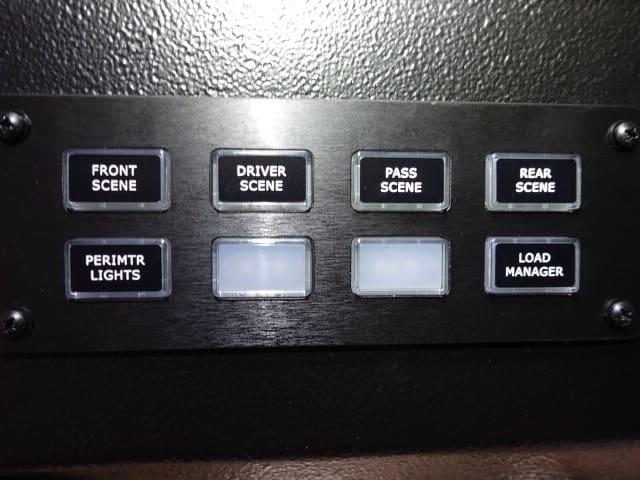

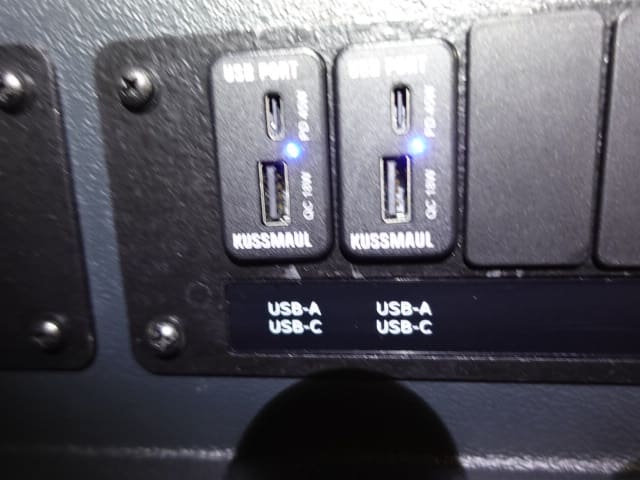

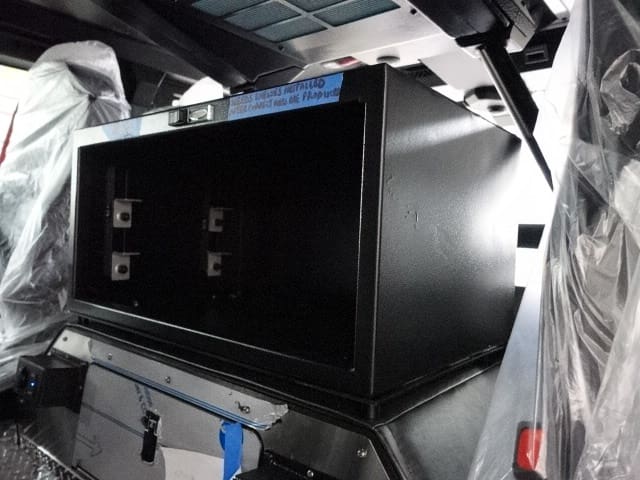

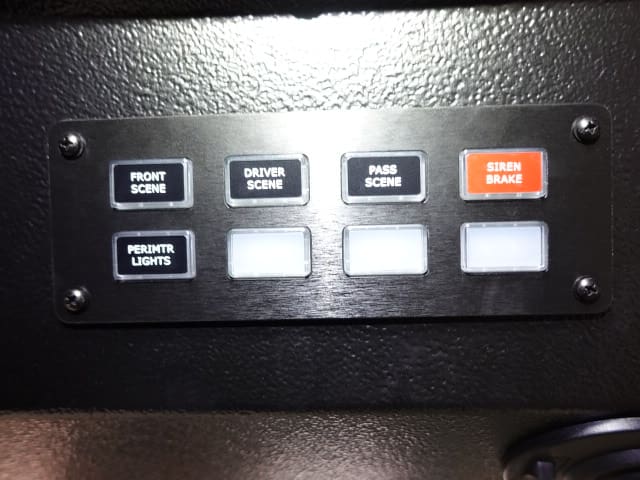

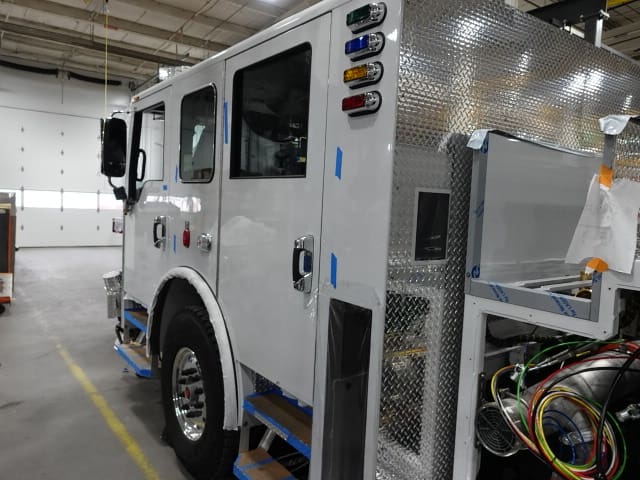

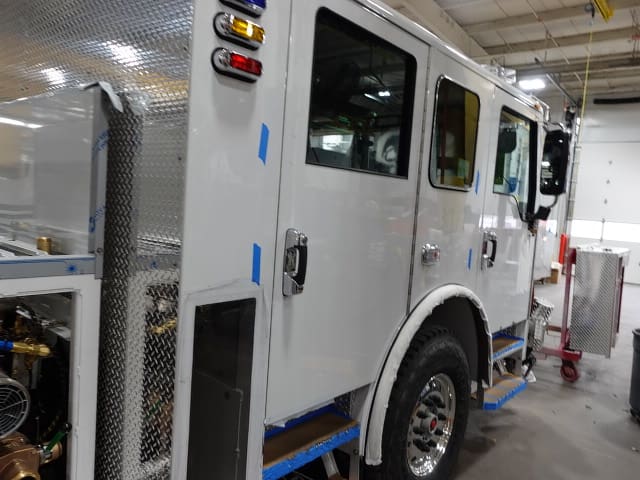

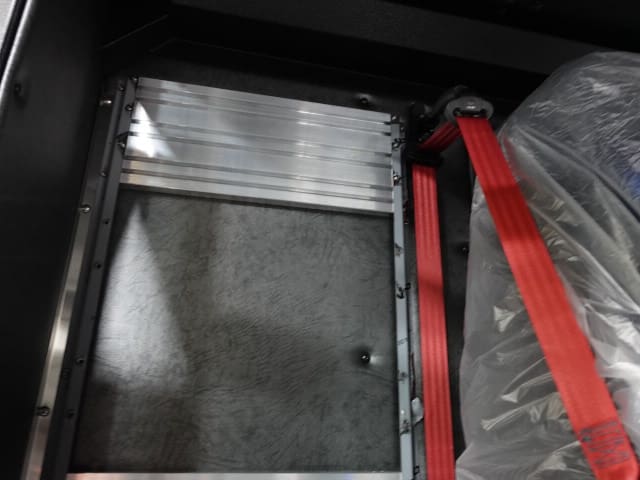

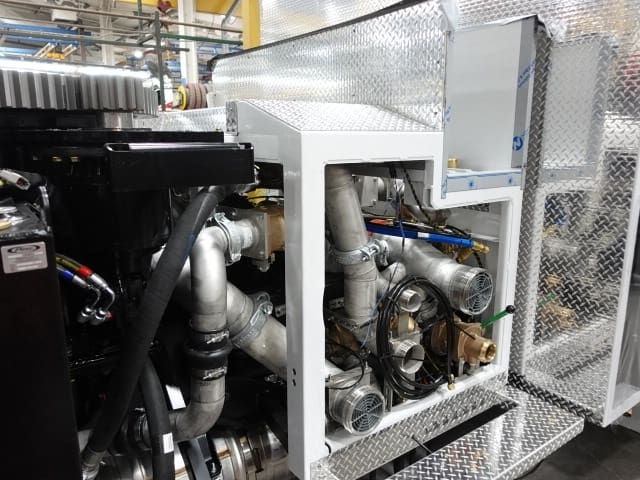

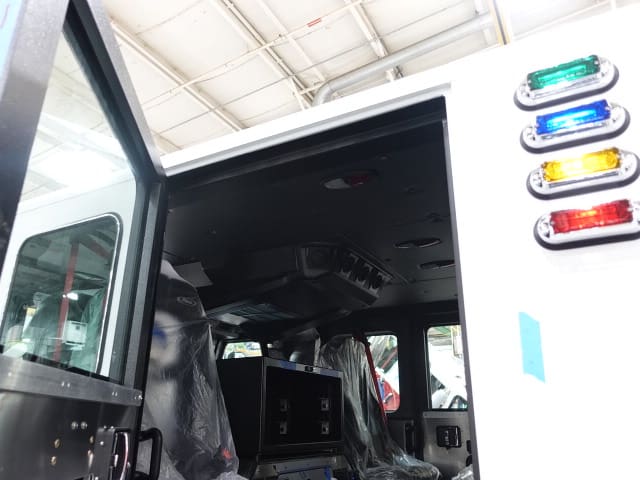

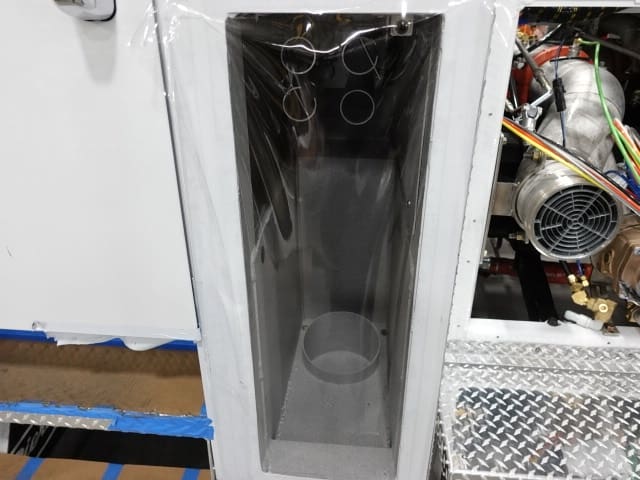

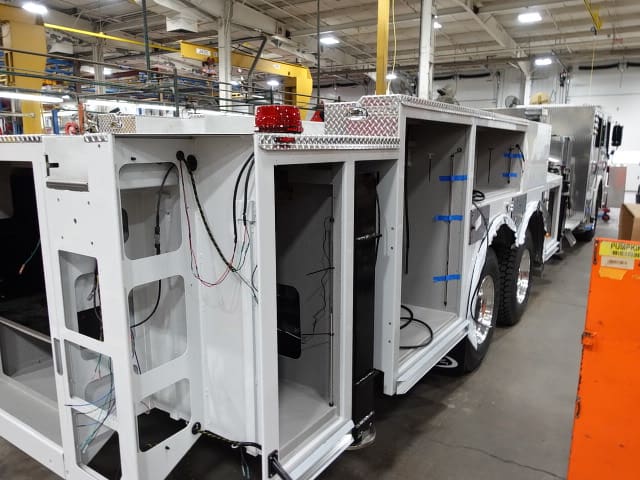

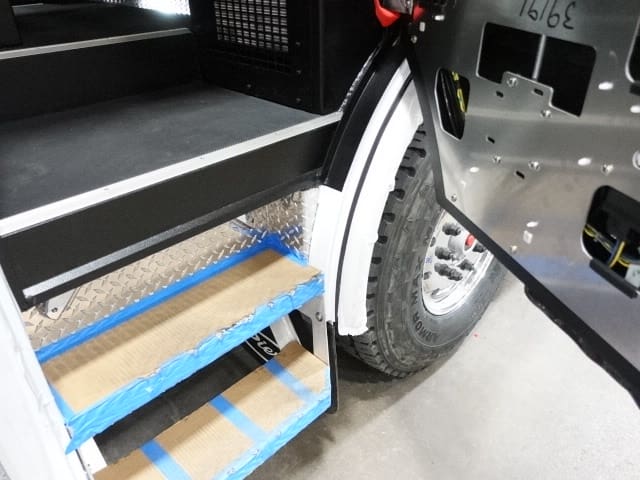

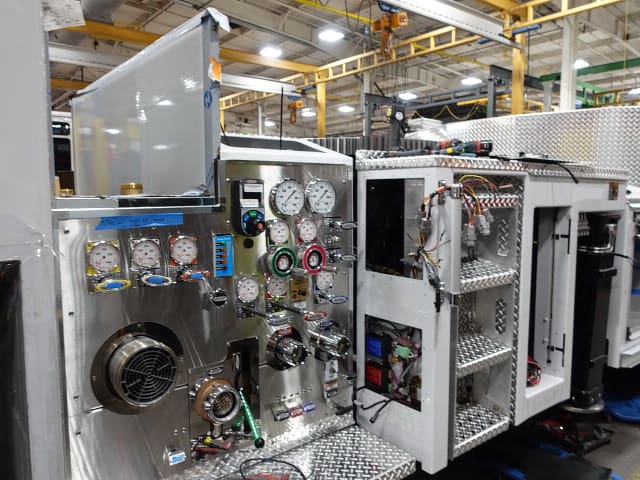

In this report, the apparatus completed testing followed by release to quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance

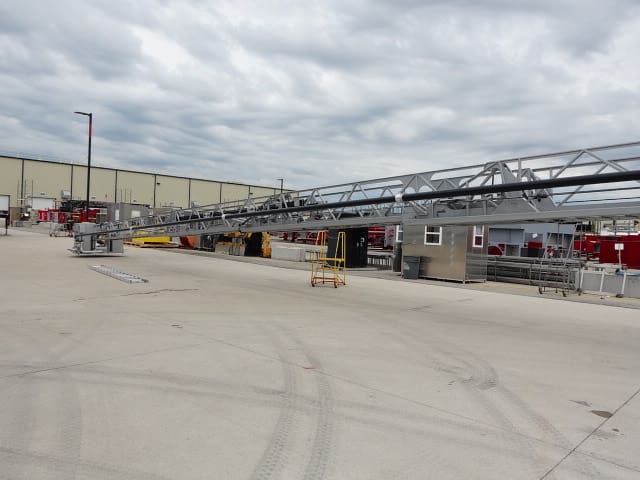

inspection. This is the last scheduled report.
05-23-25

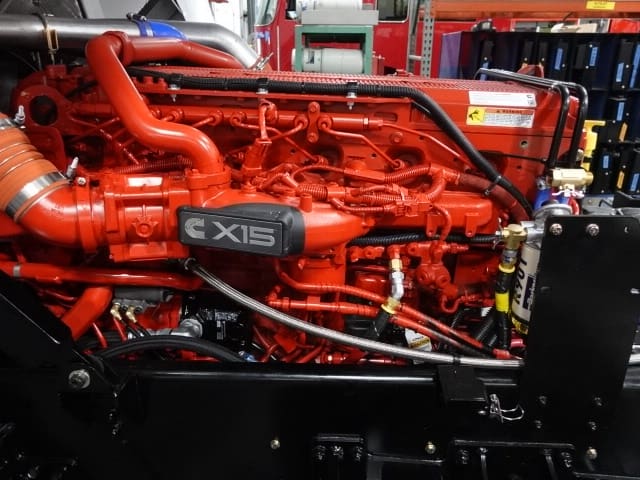

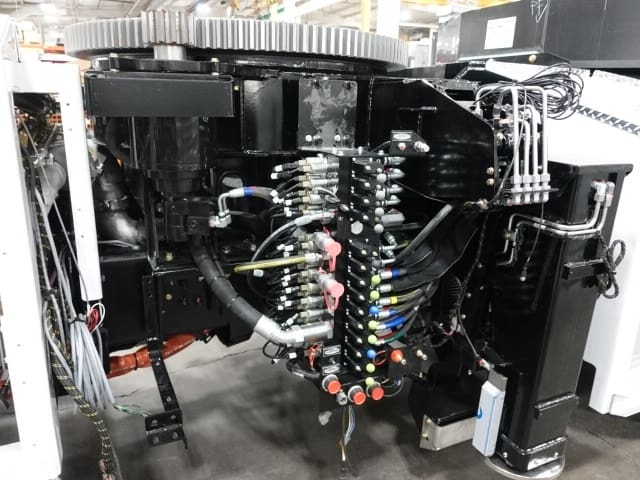

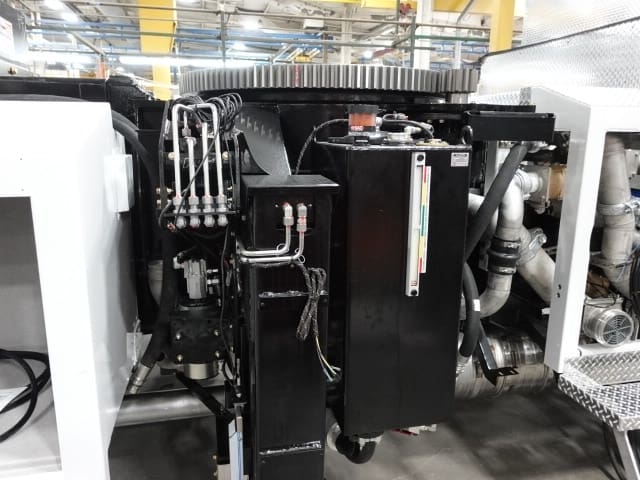

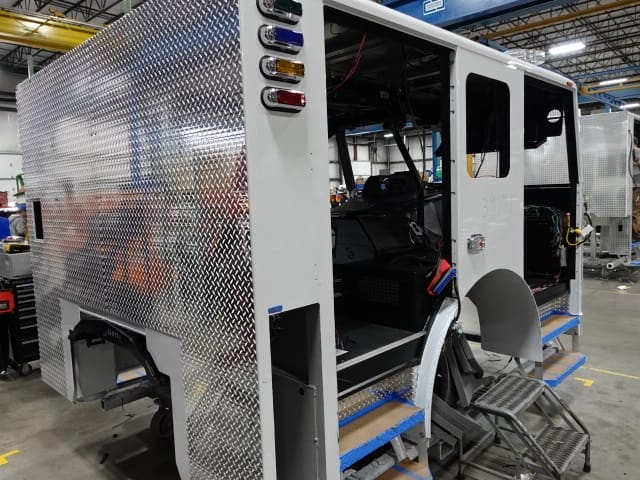

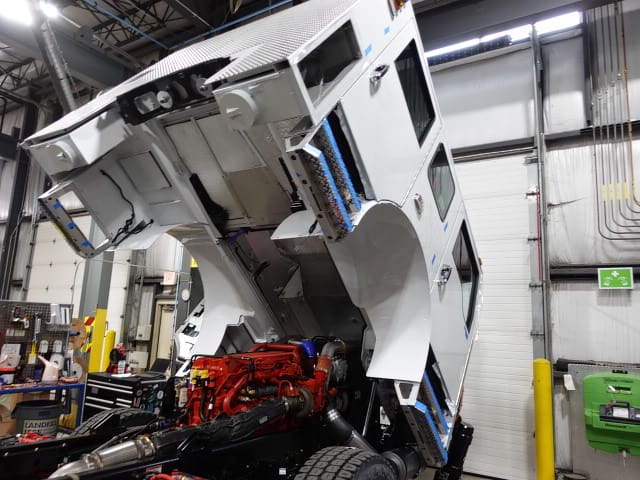

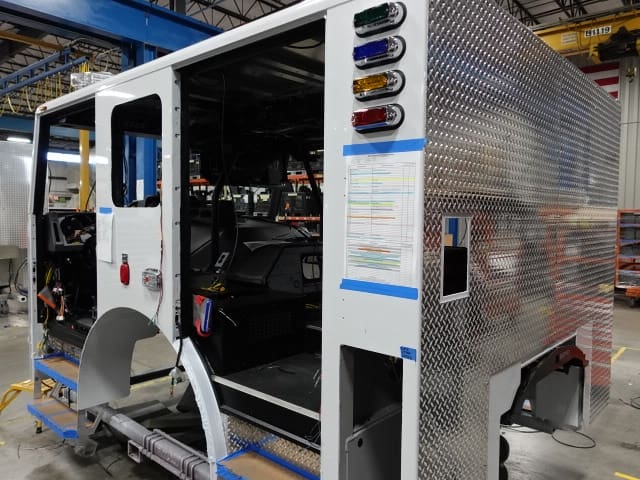

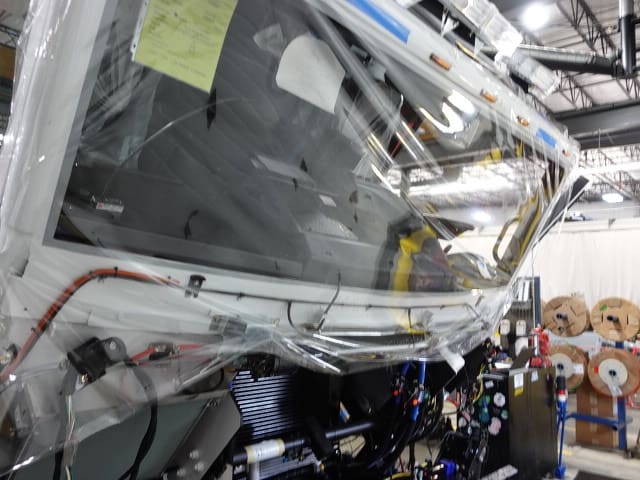

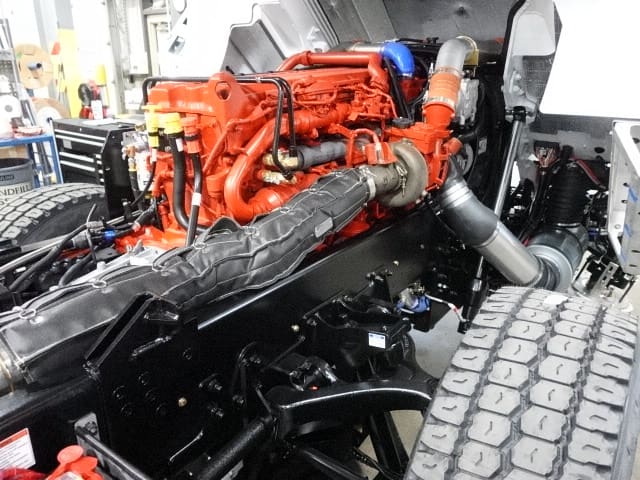

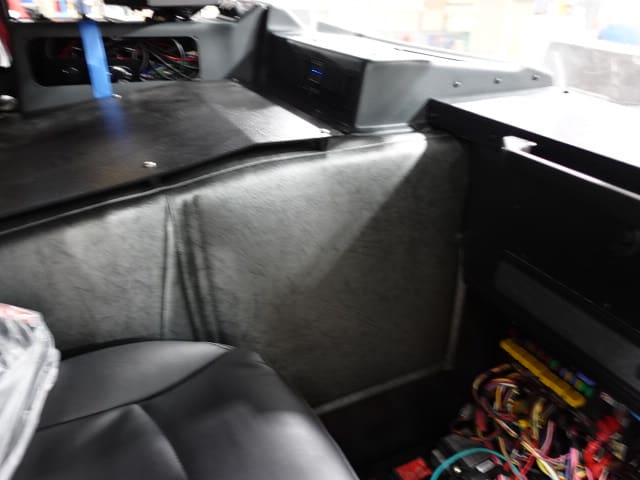

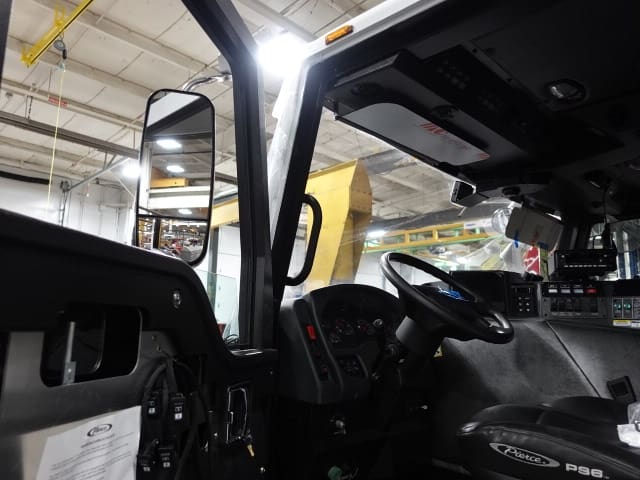

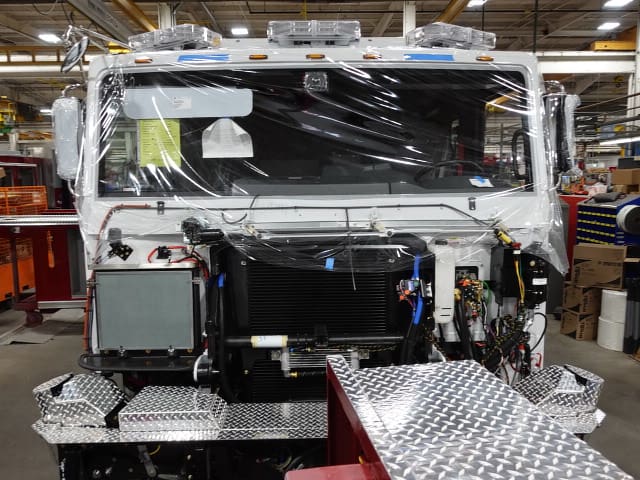

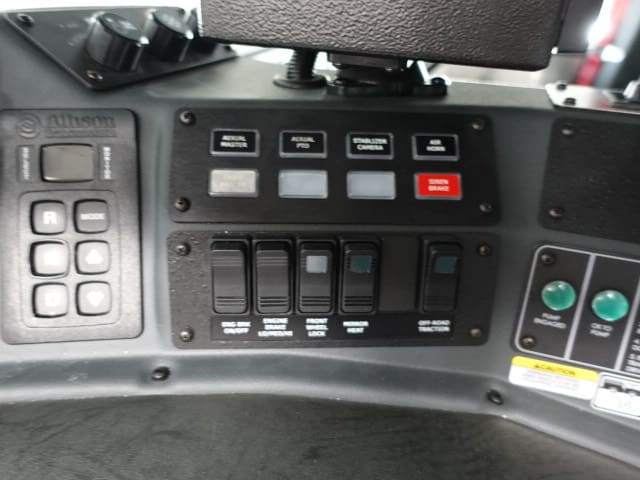

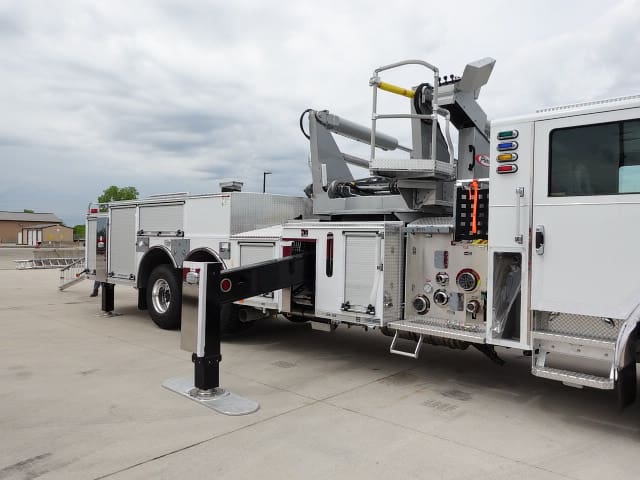

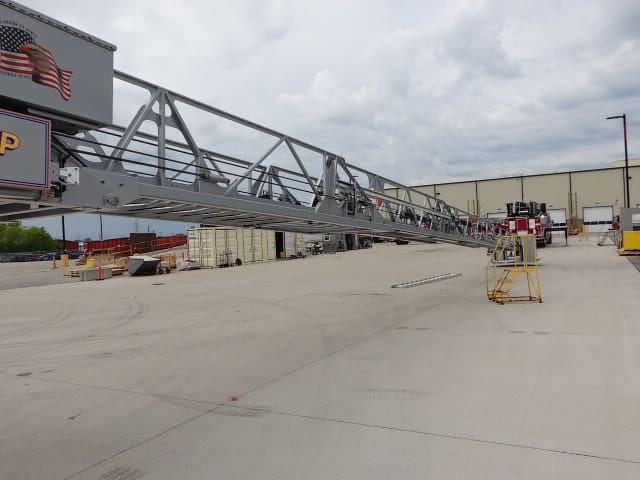

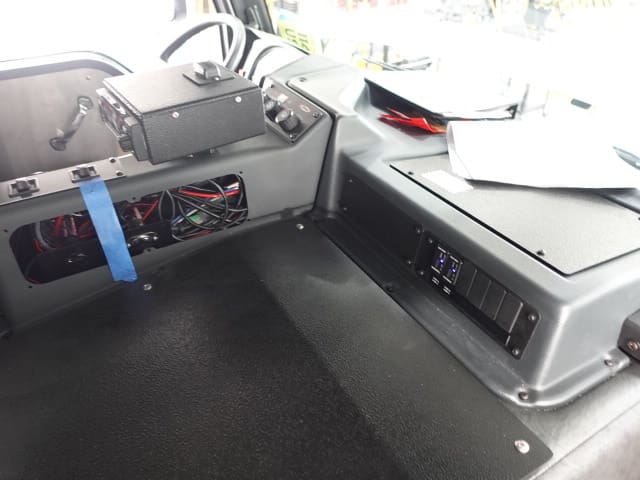

In this report, the aerial device completed initial assembly and was pinned to the apparatus followed by the start of testing.
05-16-25

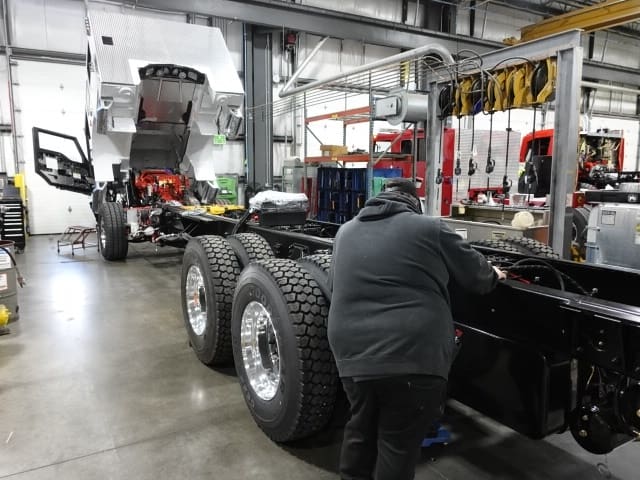

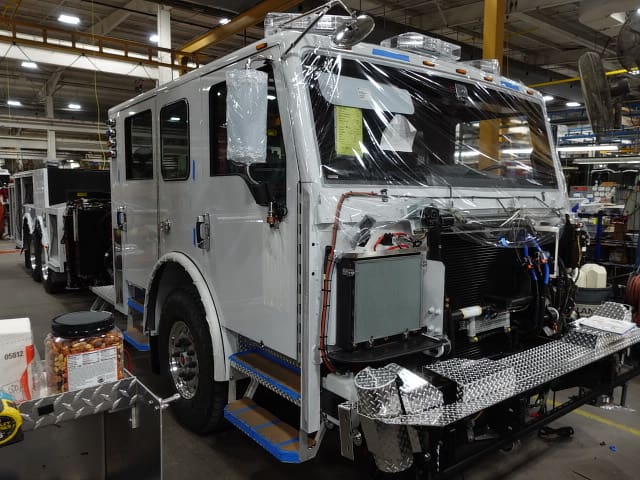

In this report, the apparatus completed final assembly and was staged while the aerial device arrived and began initial
05-02-25

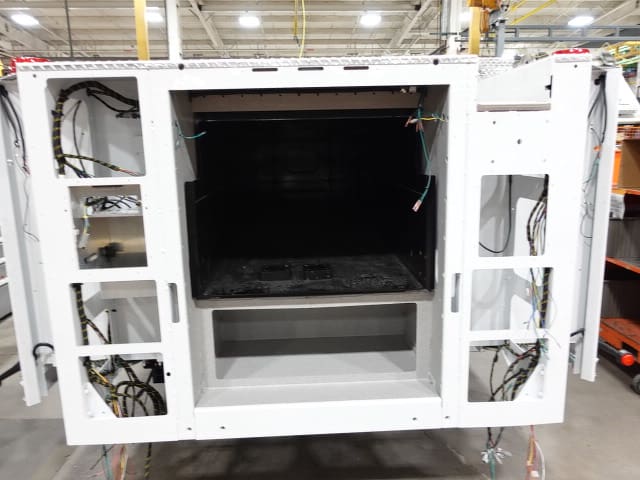

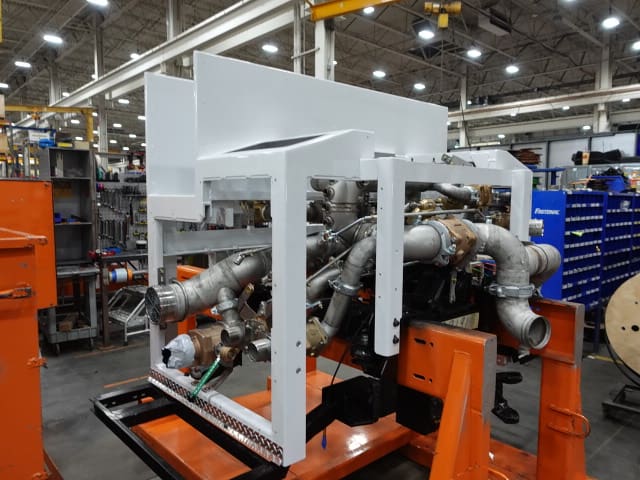

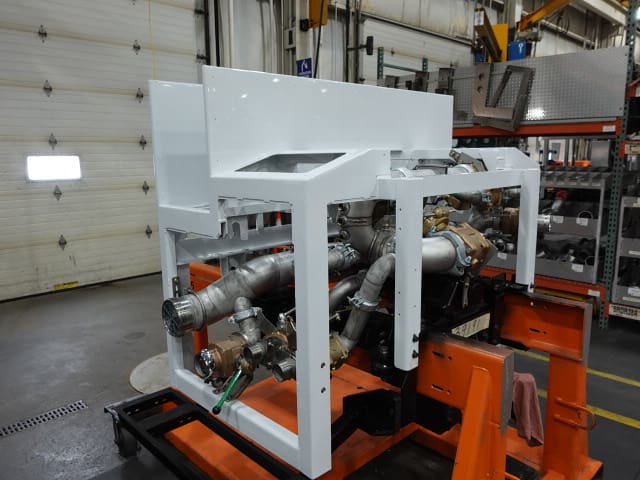

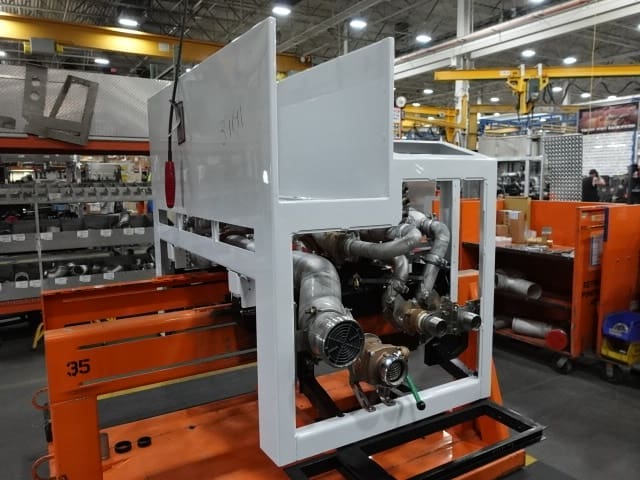

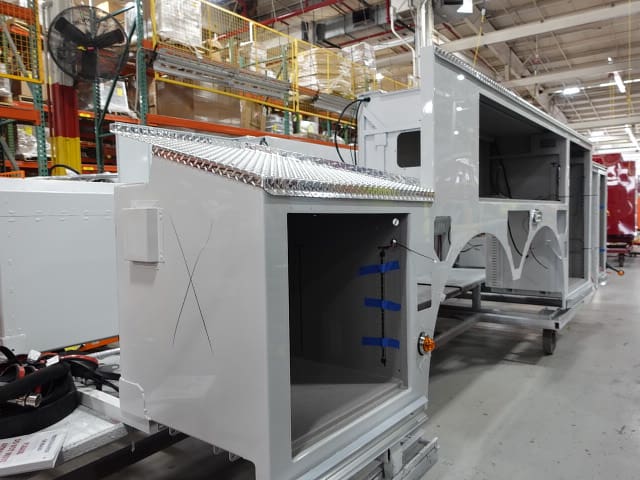

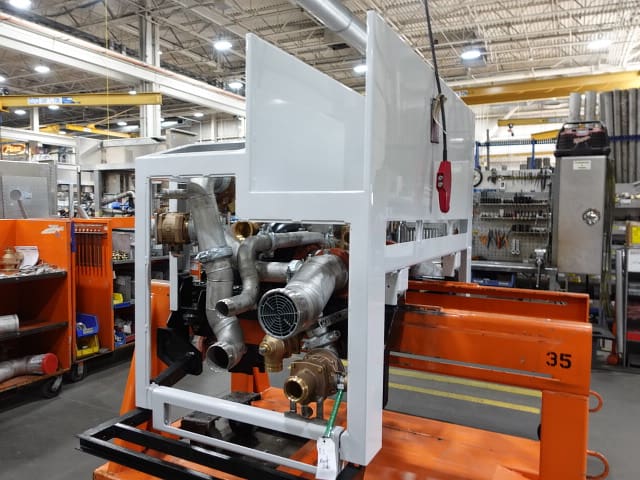

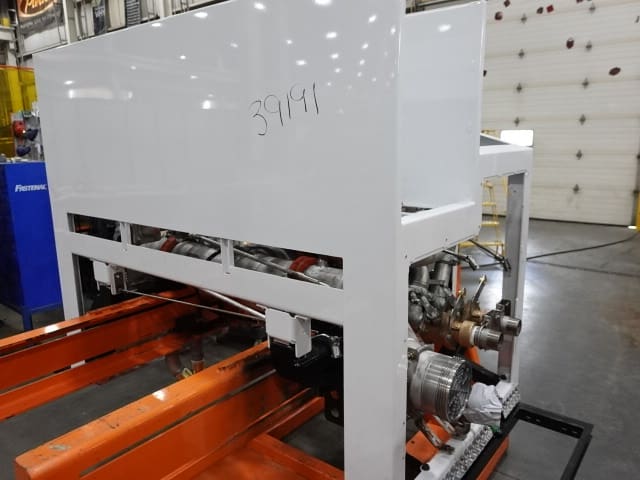

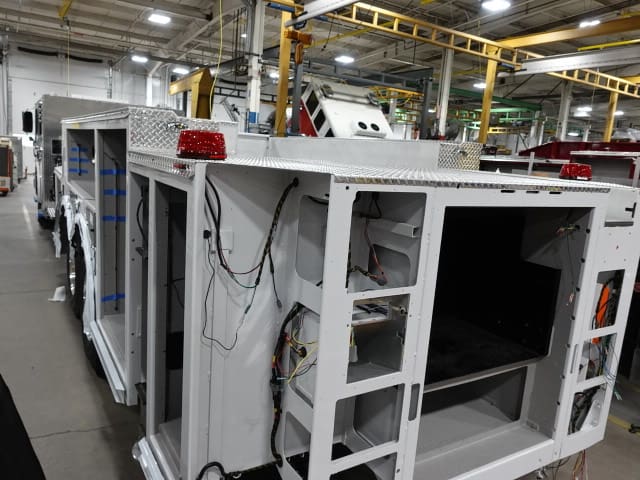

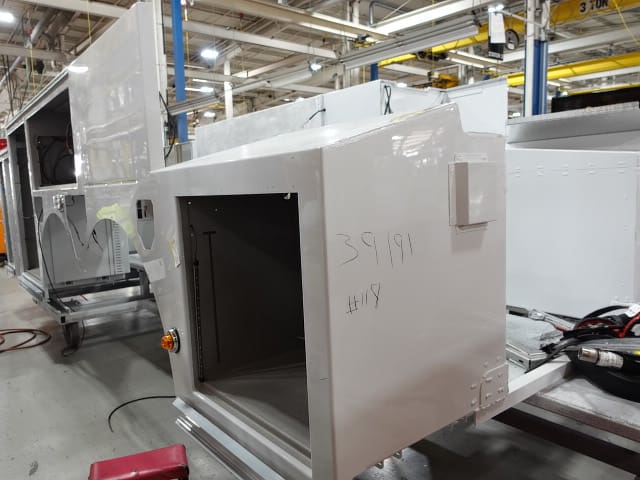

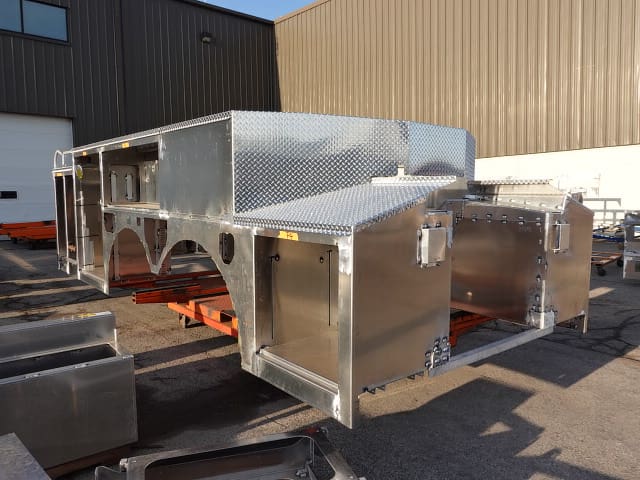

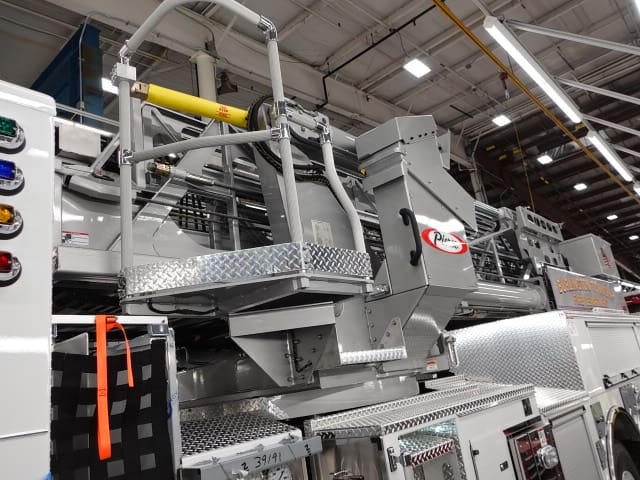

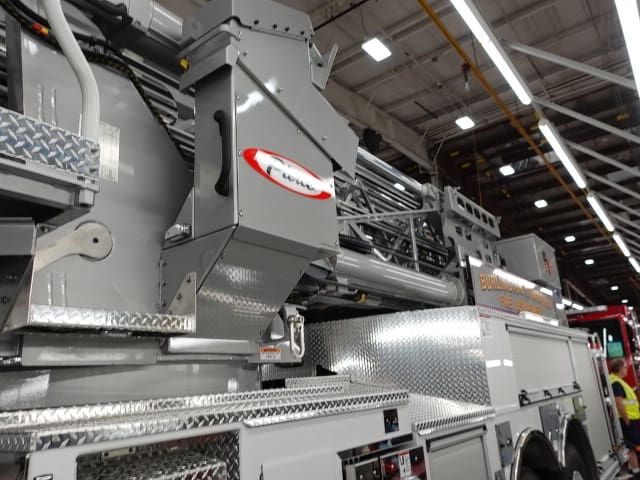

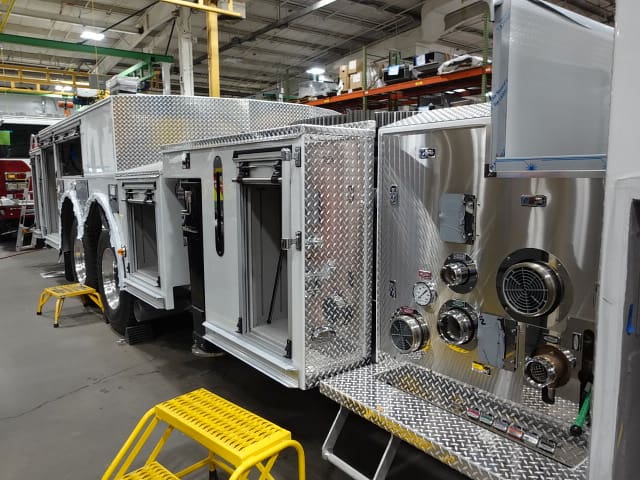

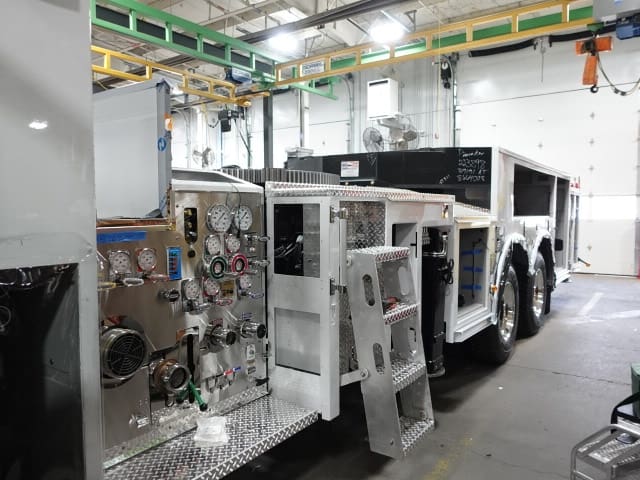

In this report, the turntable module completed initial assembly and was installed on the apparatus followed by the start of final assembly.
04-25-25

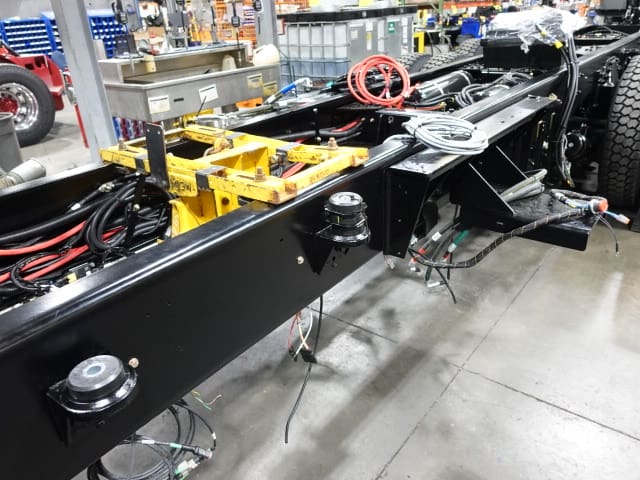

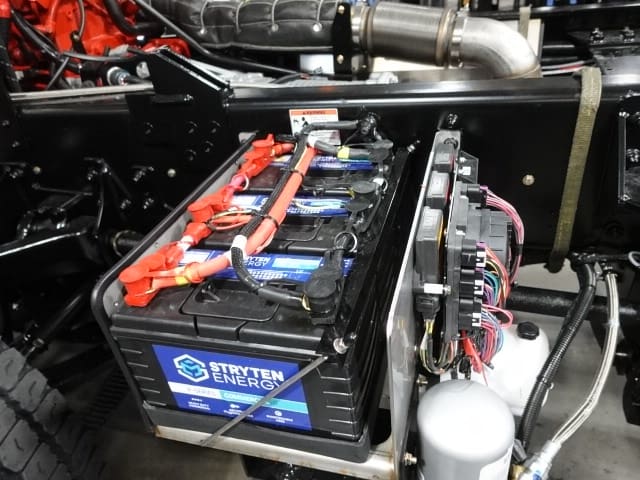

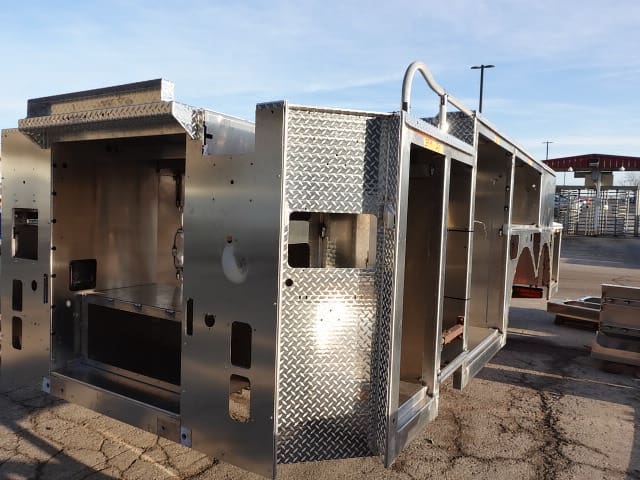

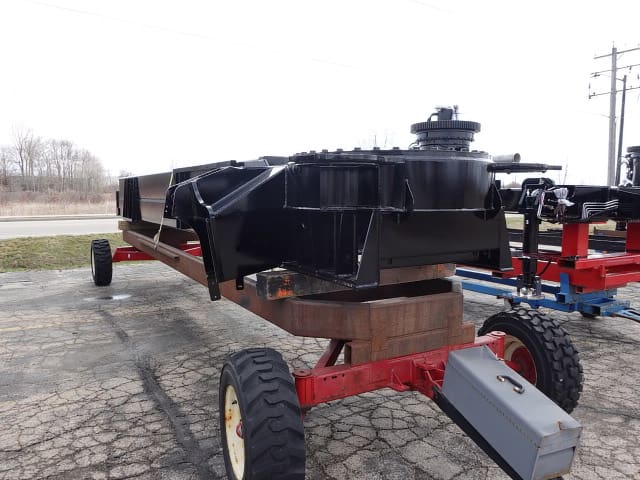

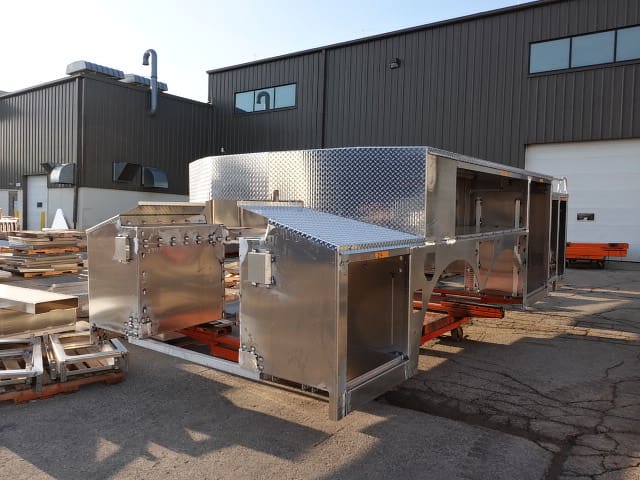

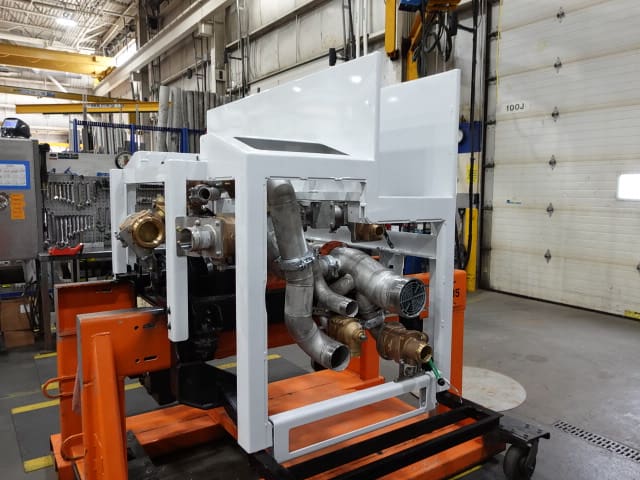

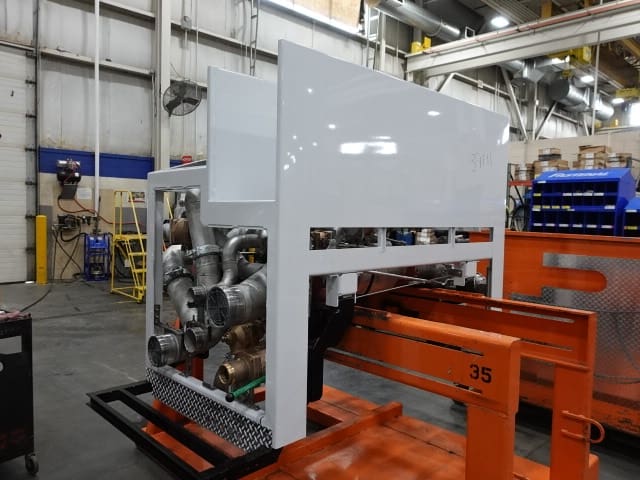

In this report, the pump house, torque box, and rear body module were merged with the chassis while the turntable module completed initial assembly.

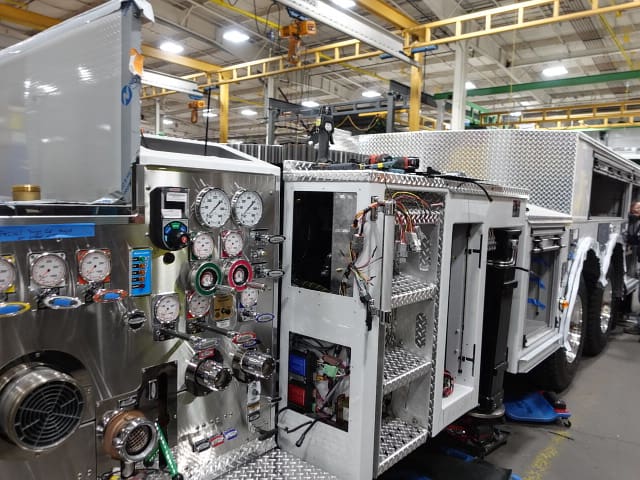

04-18-25

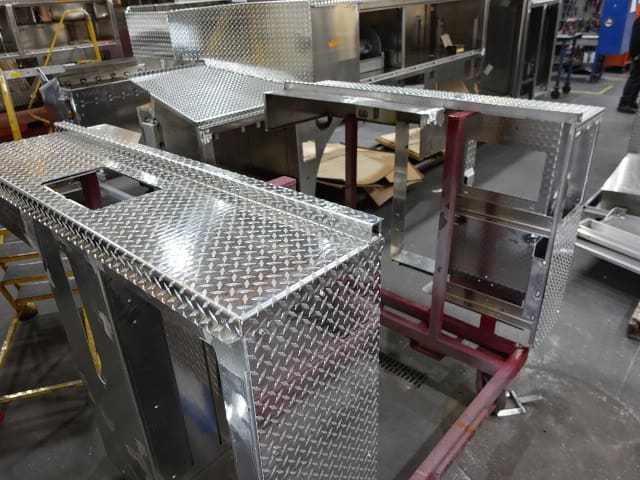

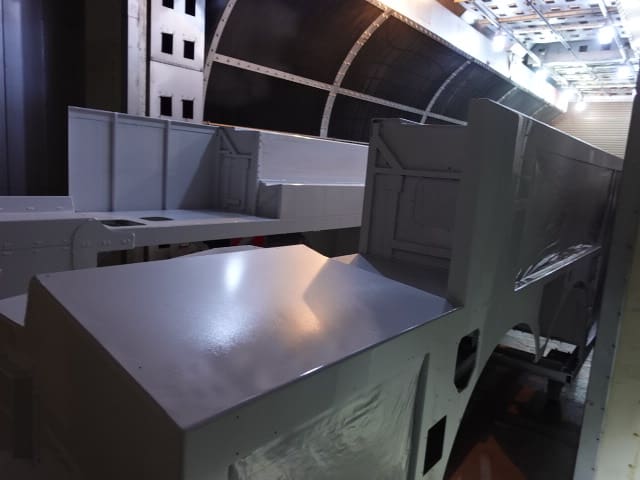

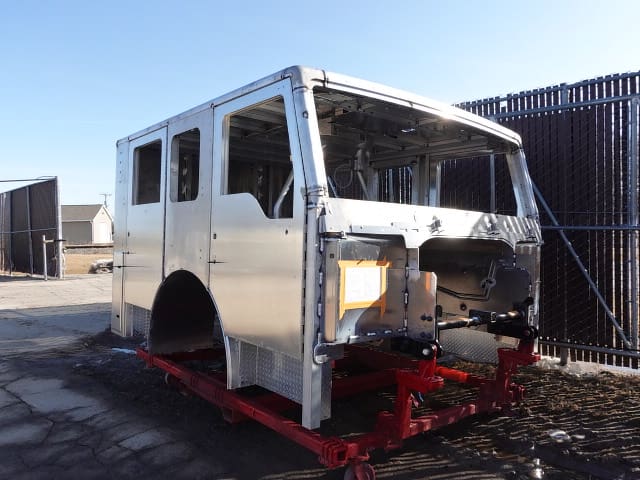

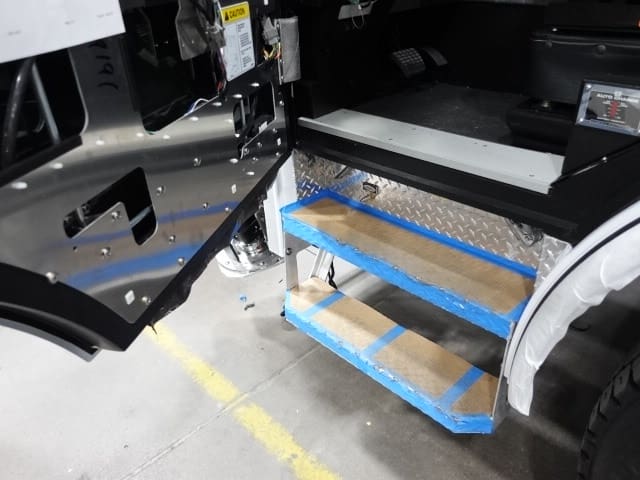

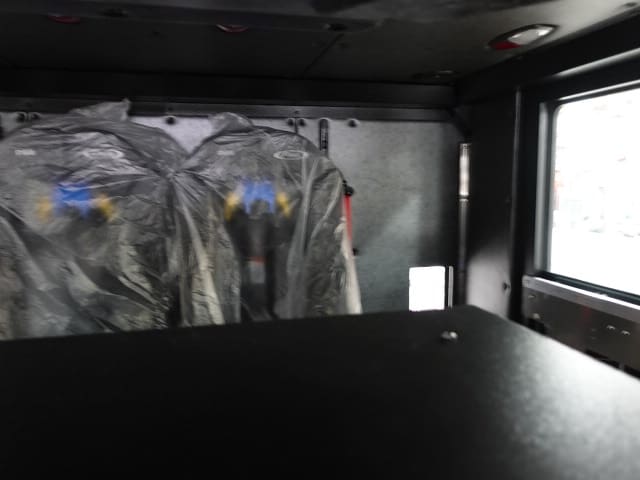

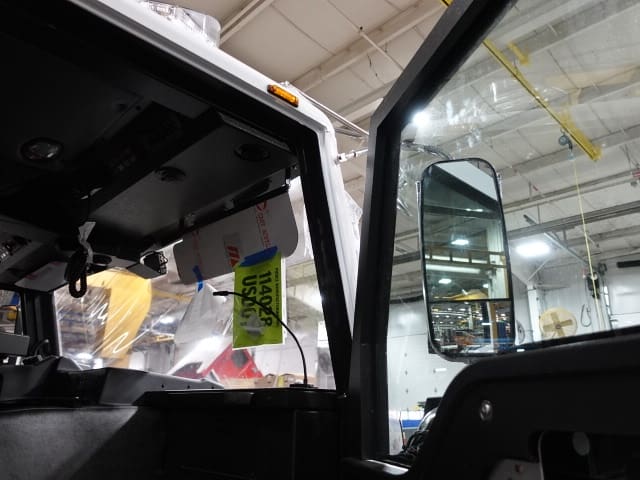

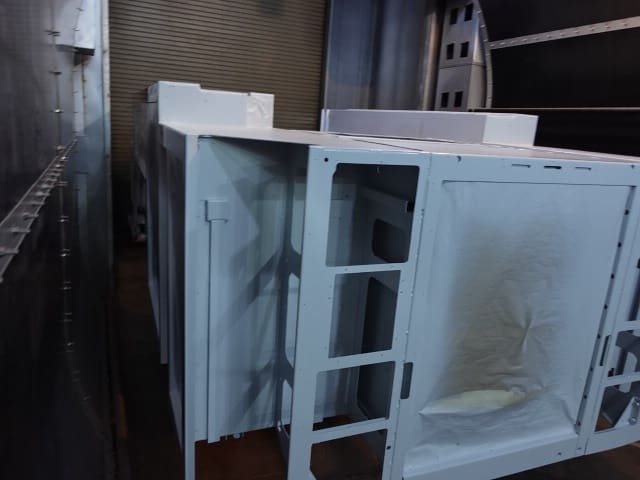

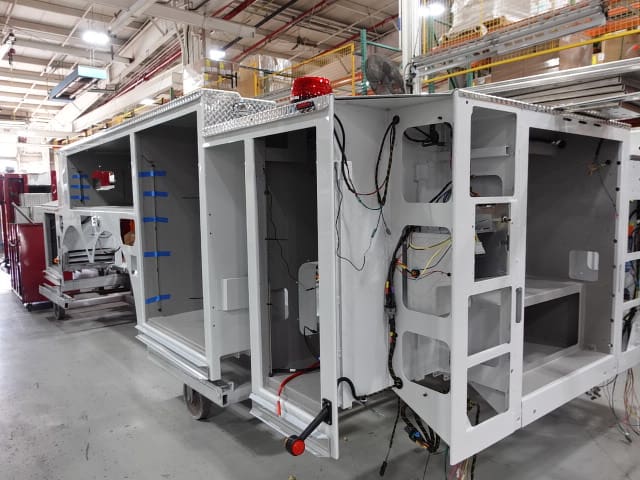

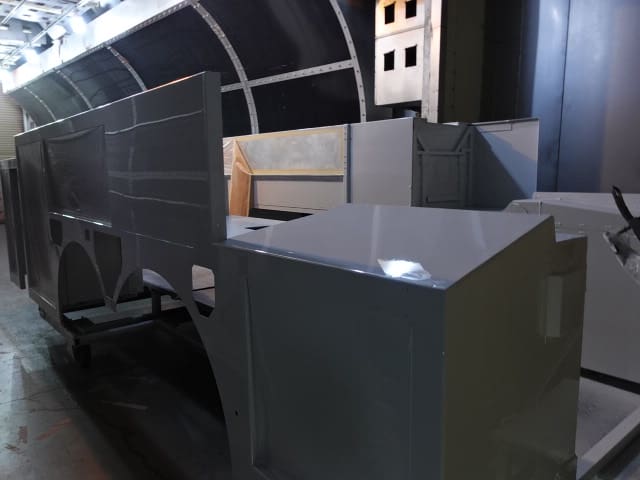

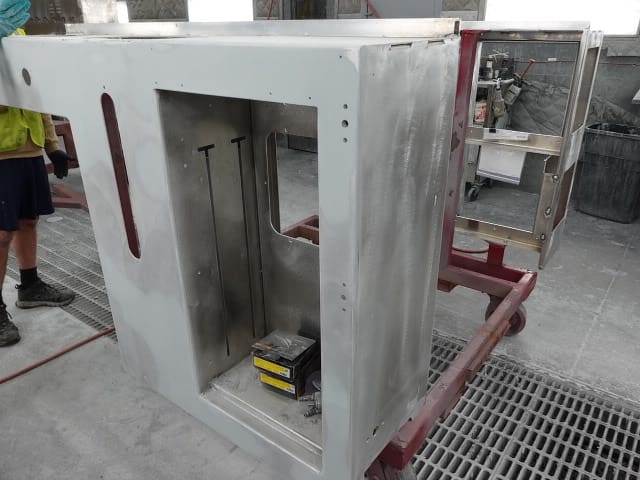

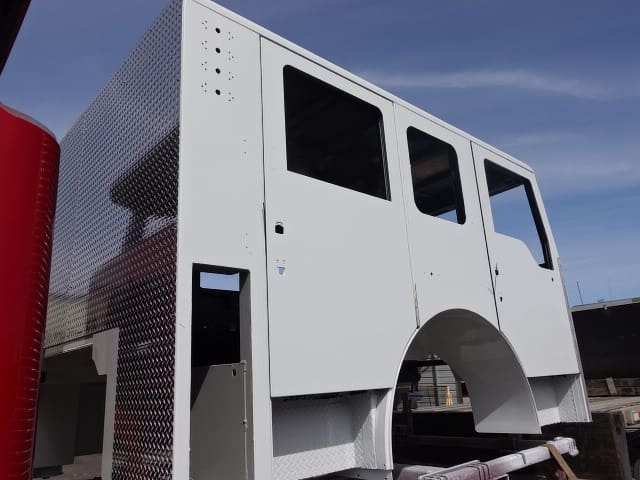

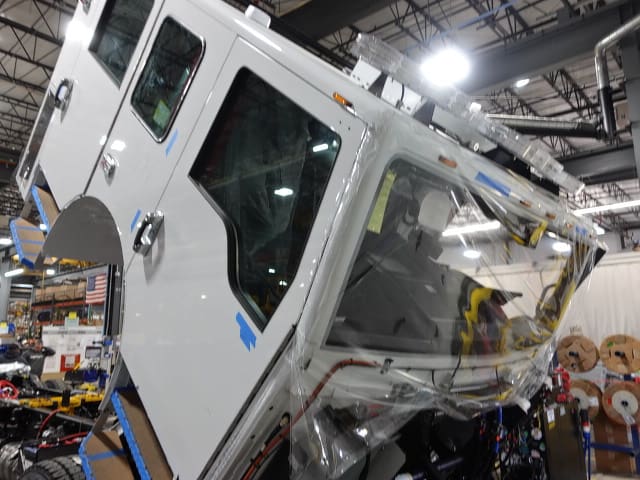

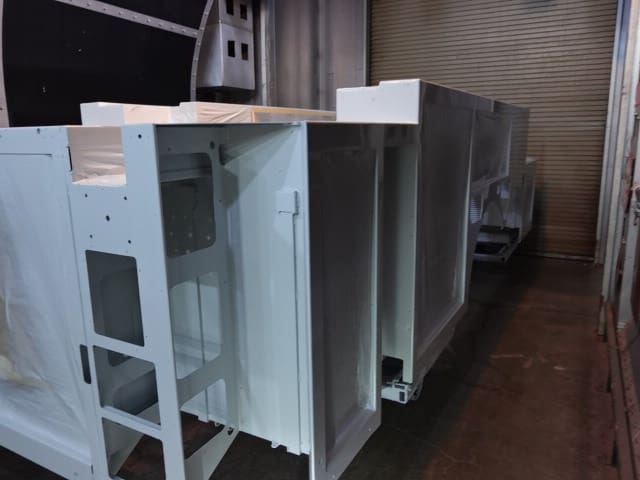

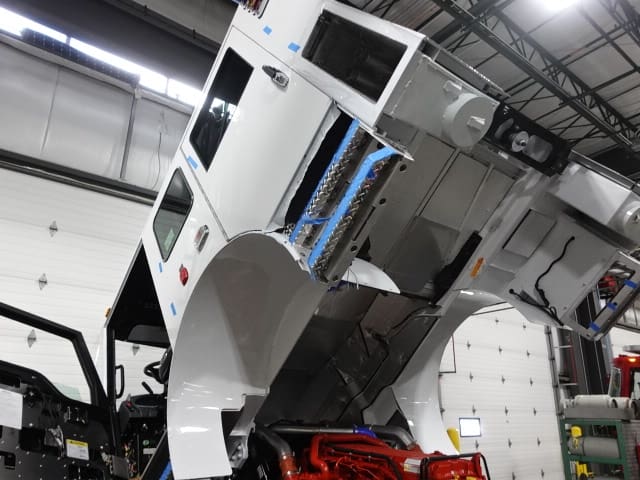

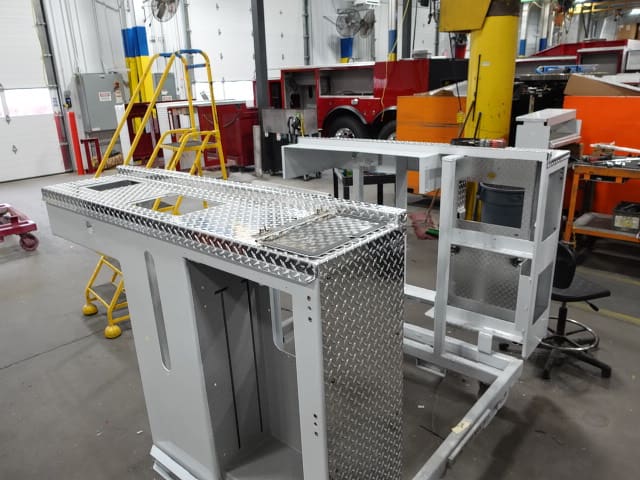

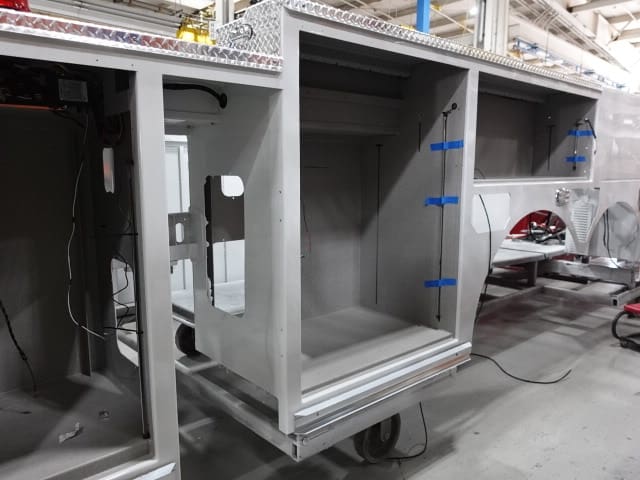

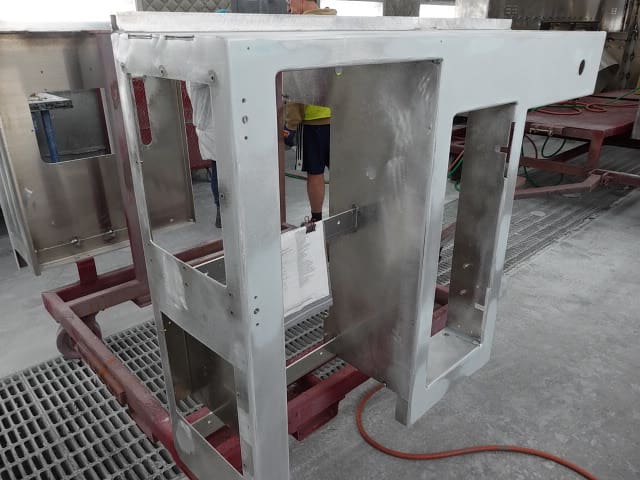

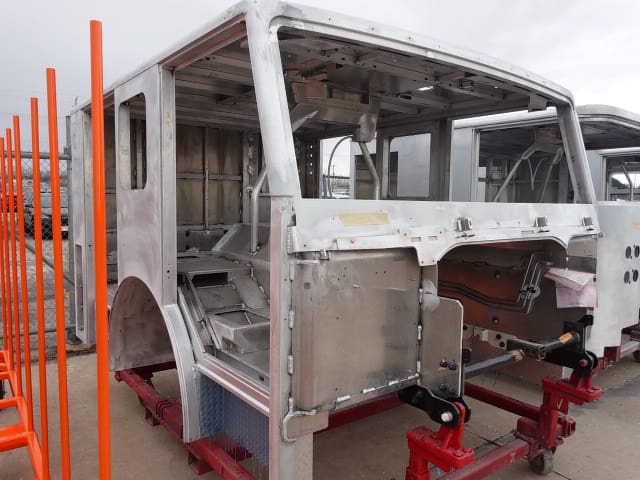

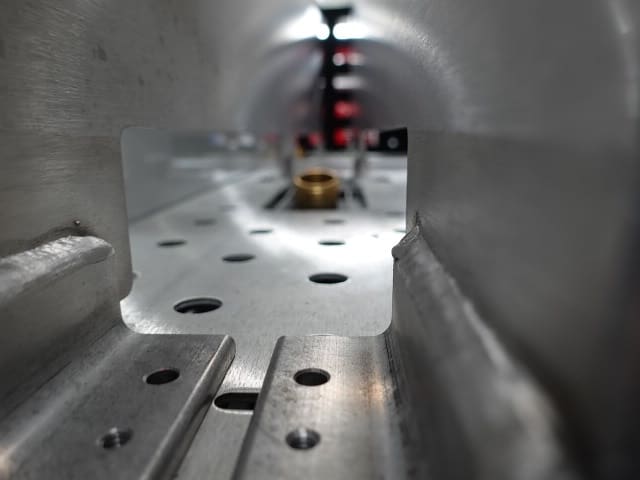

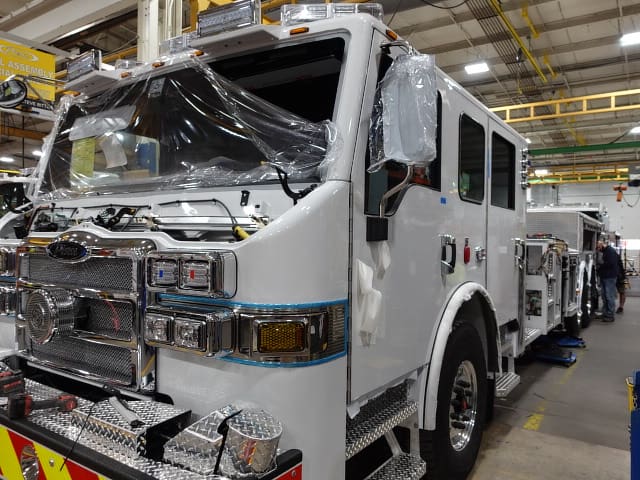

In this report, the cab completed initial assembly and was installed on the frame, the pump house continued initial assembly, the torque box remained staged, the turntable module began the paint process, and the rear body completed paint and began initial assembly.

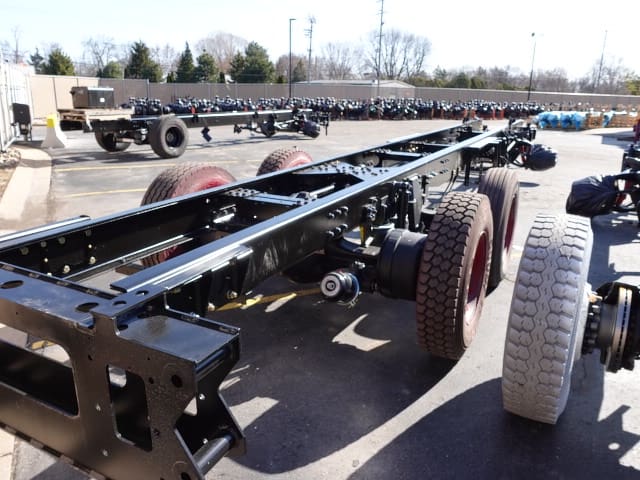

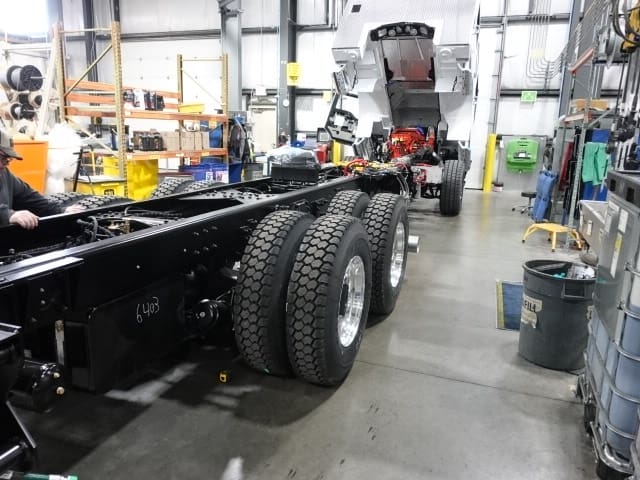

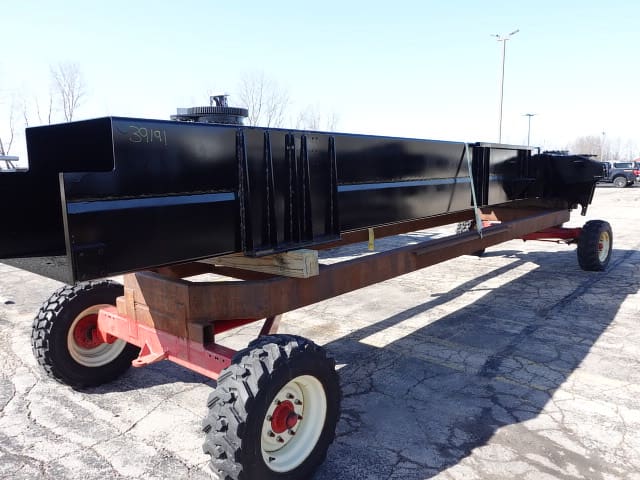

04-11-25

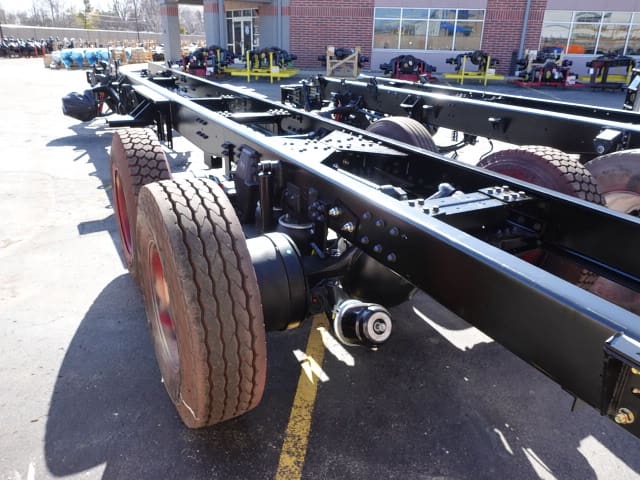

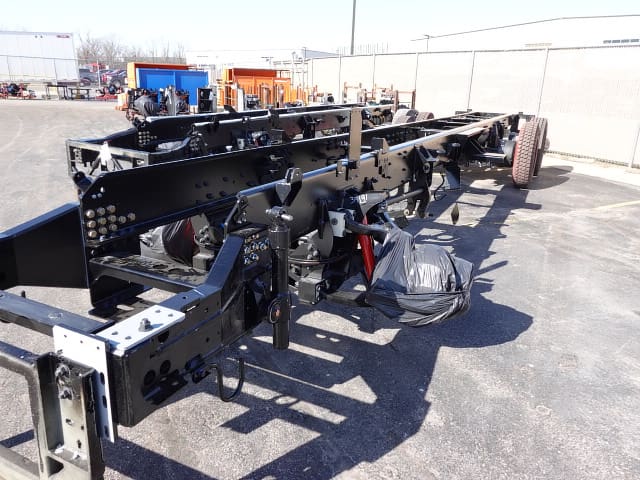

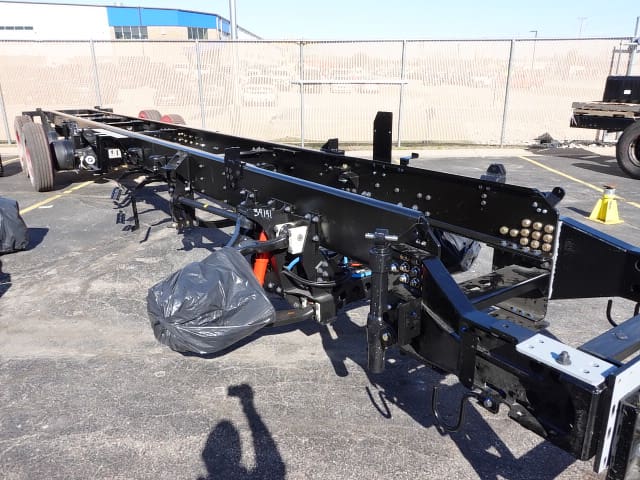

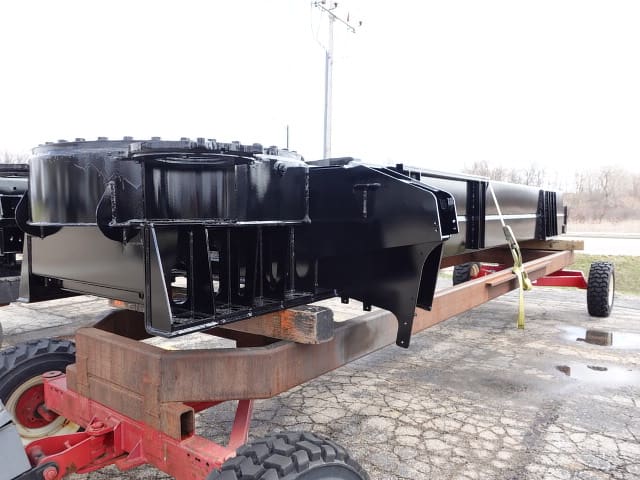

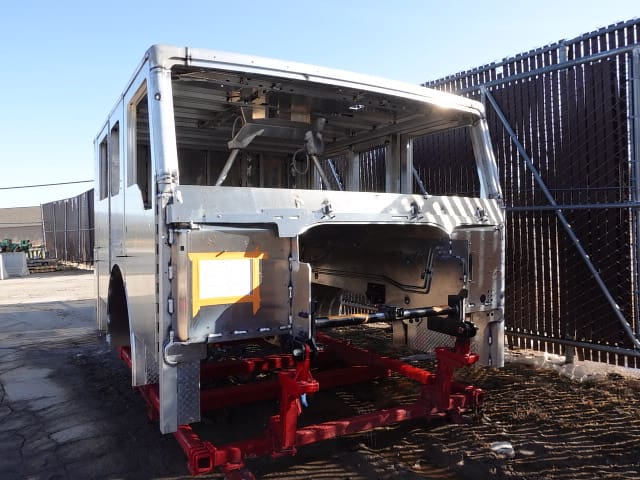

In this report, the cab began initial assembly, the frame build began, the pump house began initial assembly, the torque box arrived and was staged, the turn table module began fabrication, and the rear body began the paint process.
04-04-25

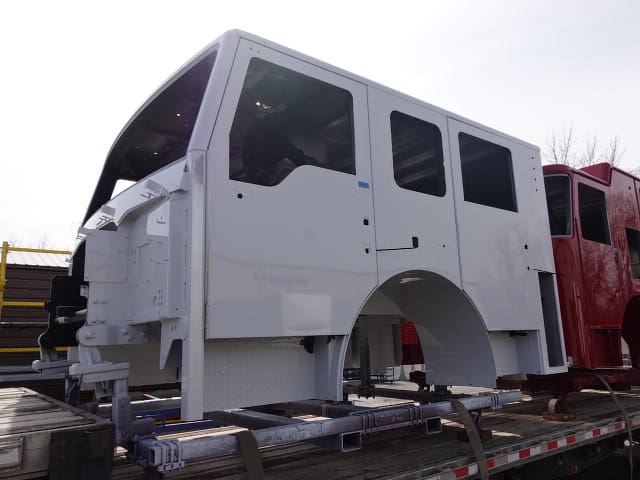

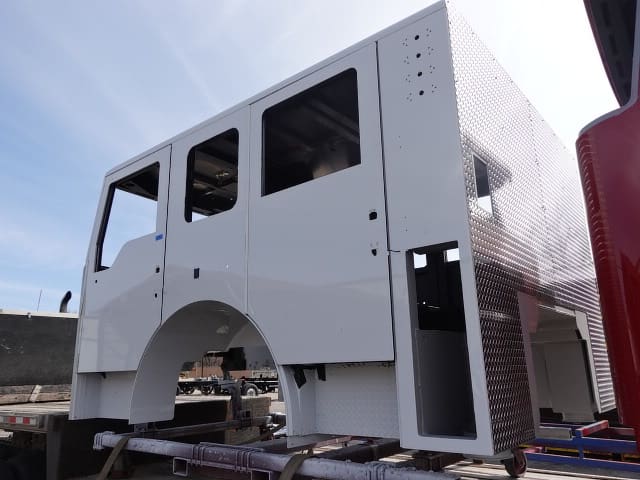

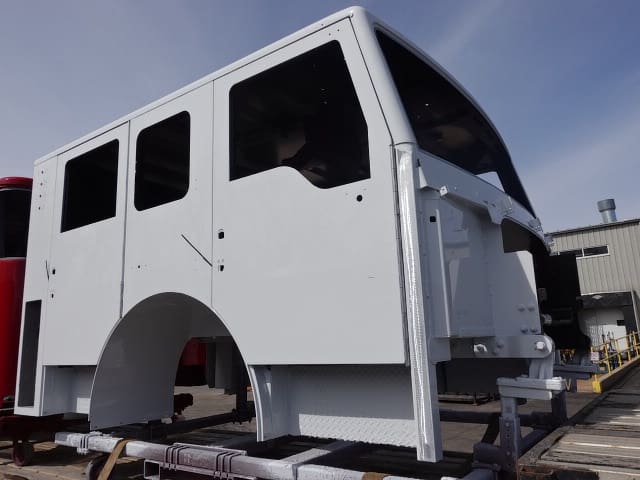

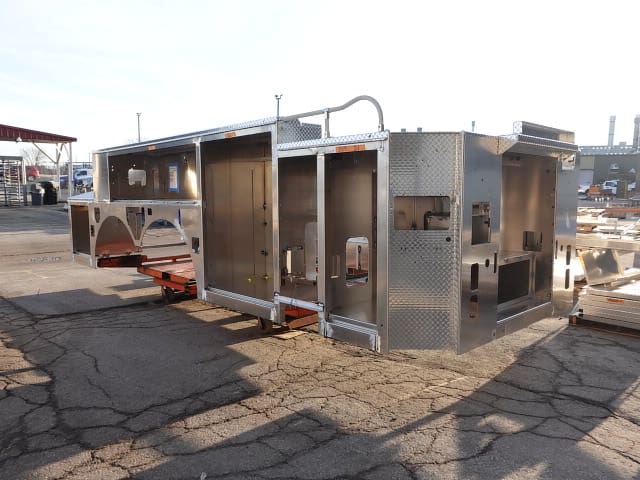

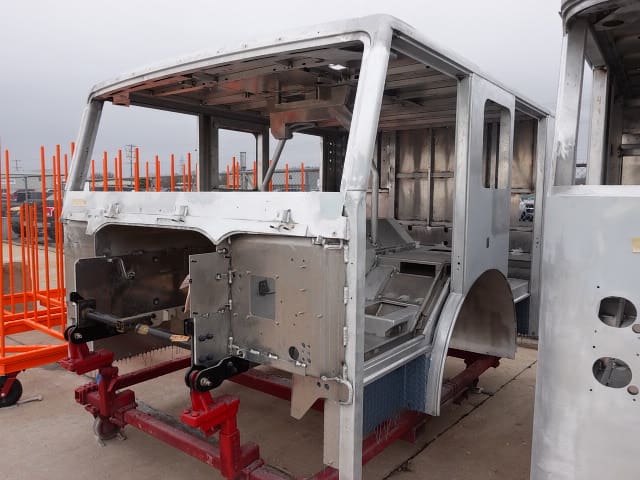

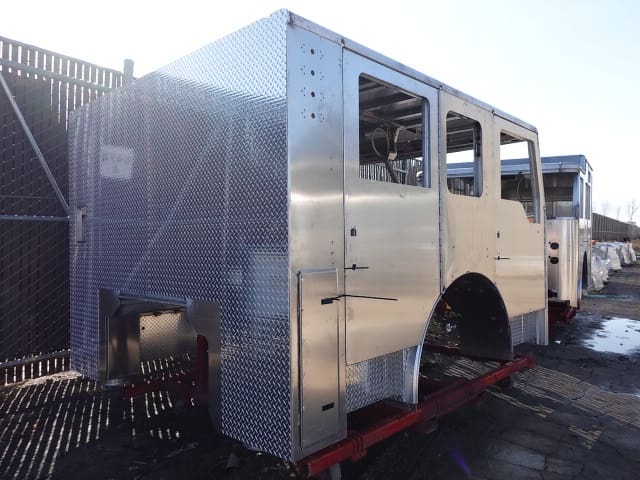

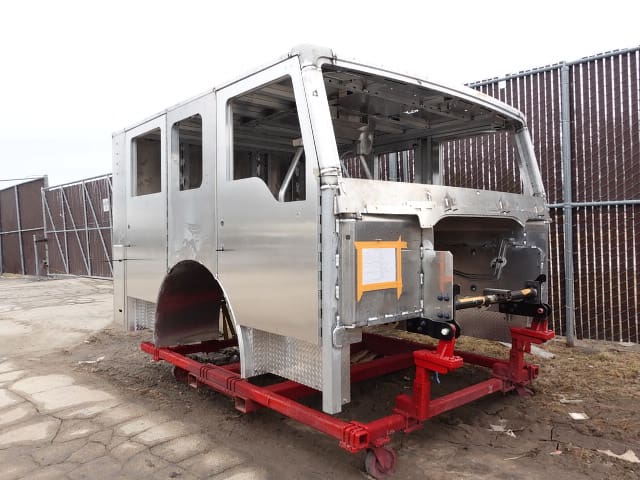

In this report, the cab completed the paint process while the rear body was fabricated.
03-07-25

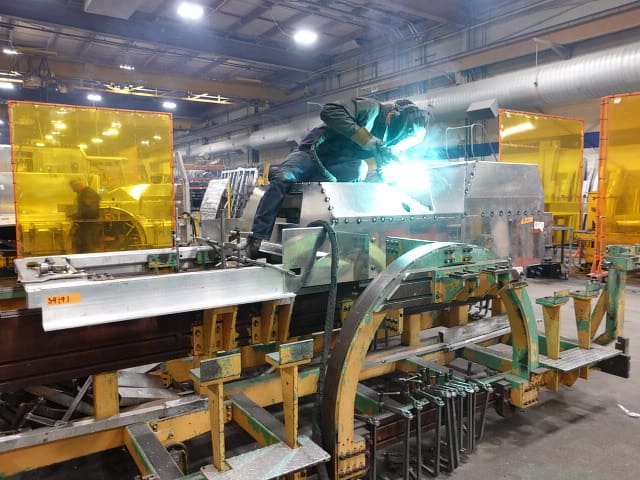

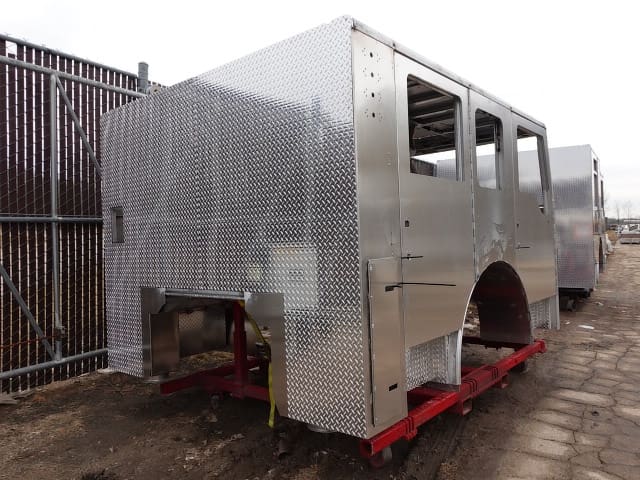

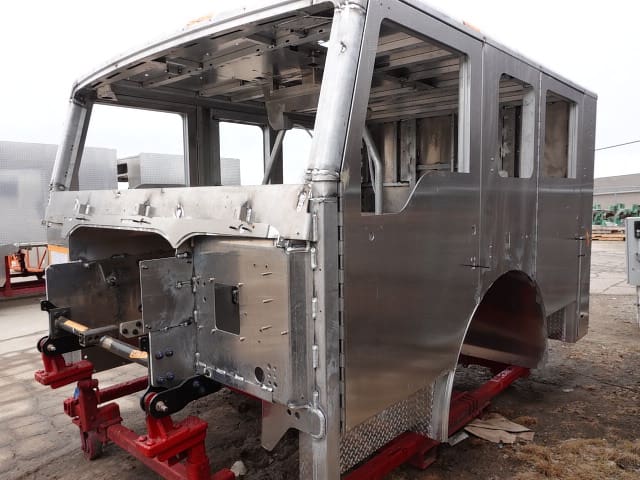

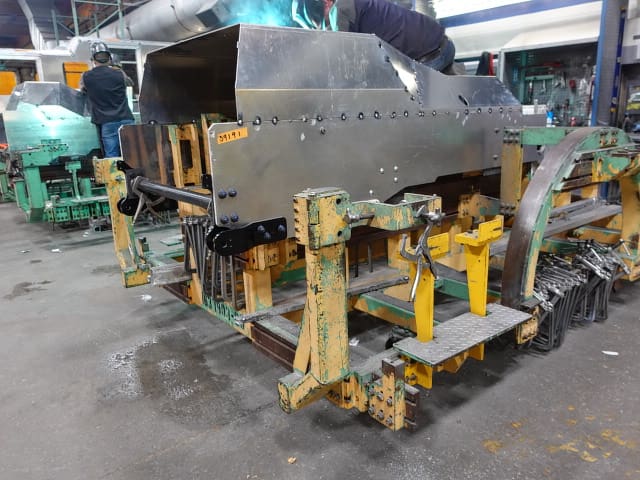

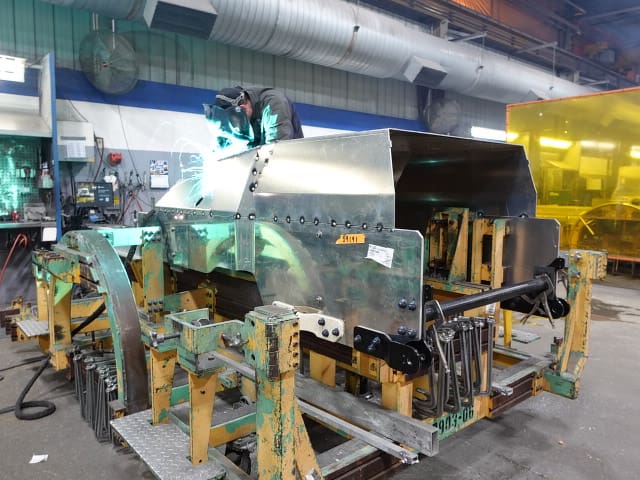

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
