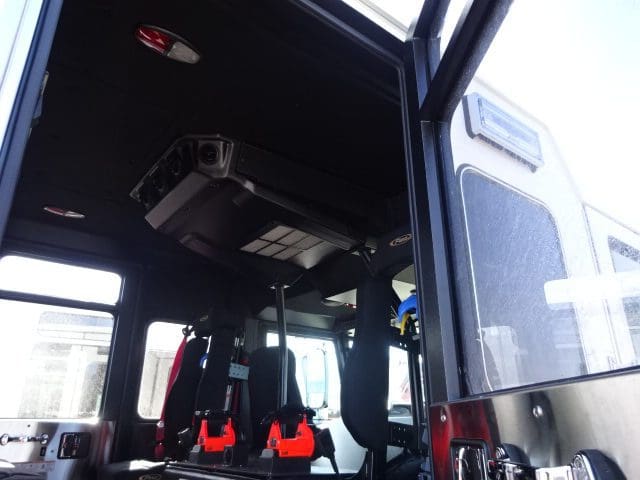

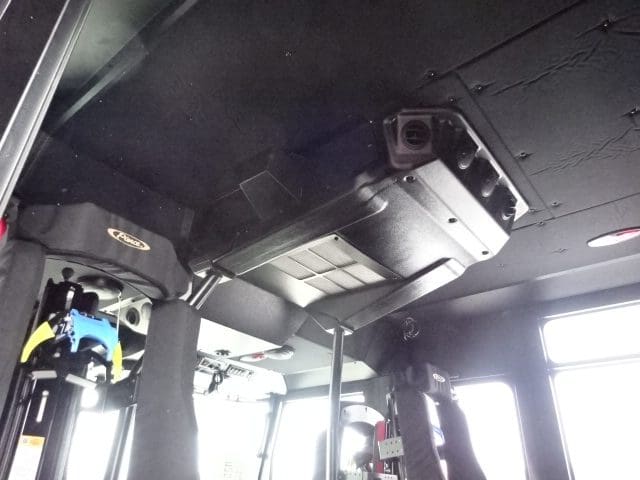

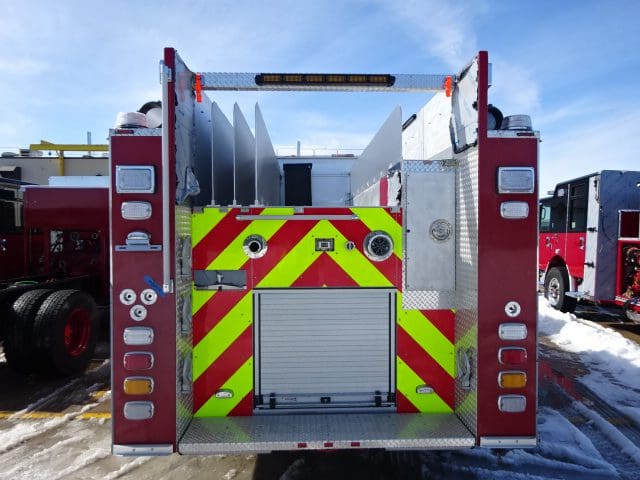

03-03-23

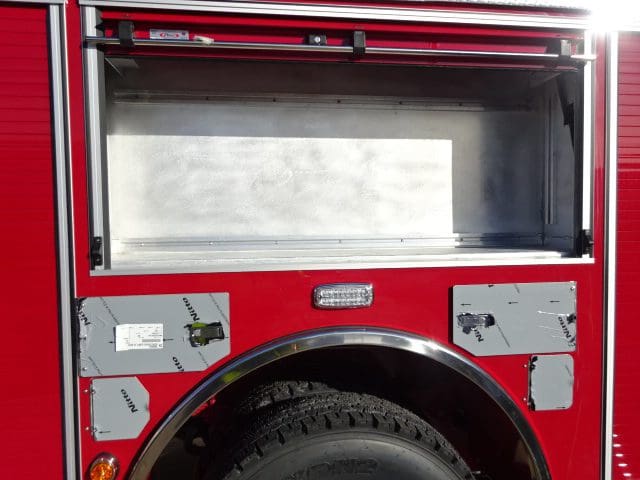

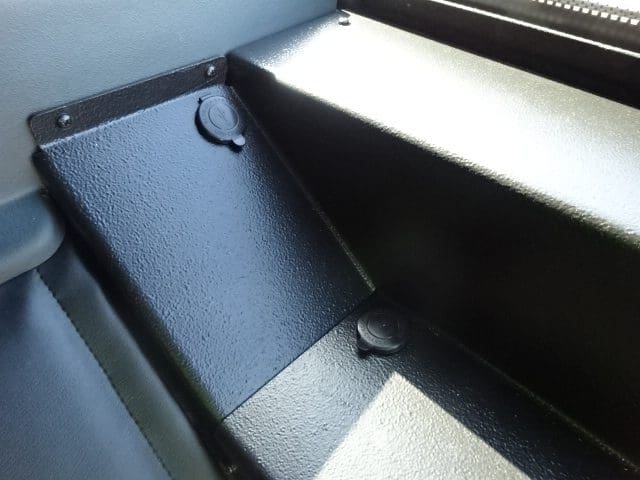

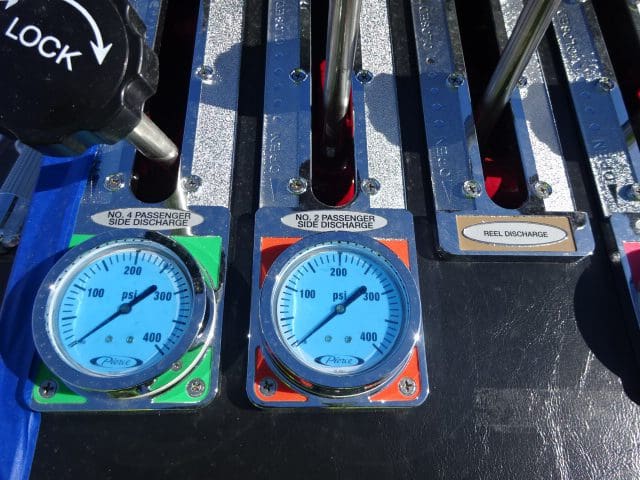

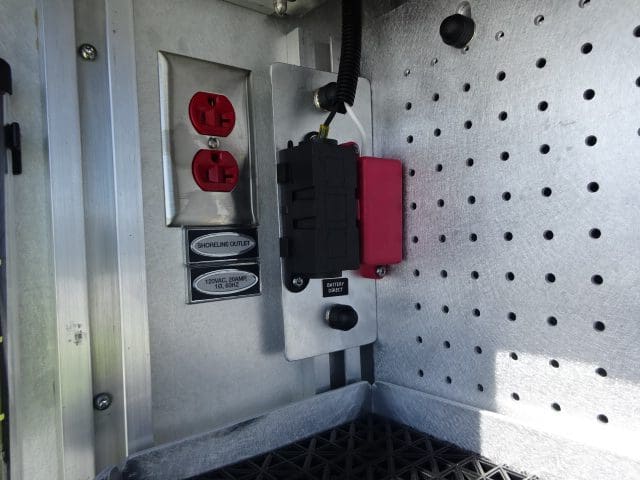

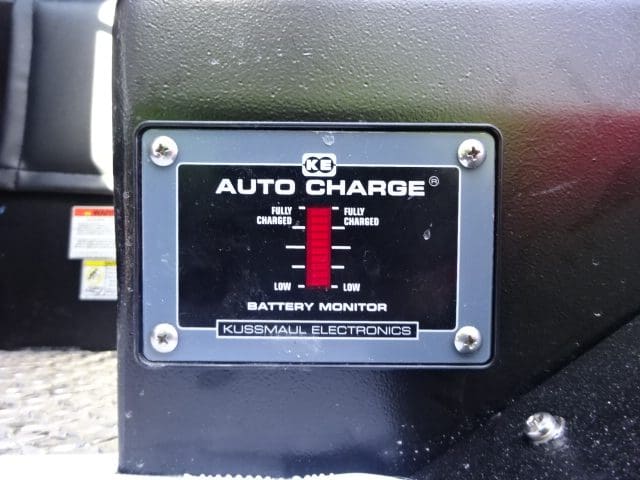

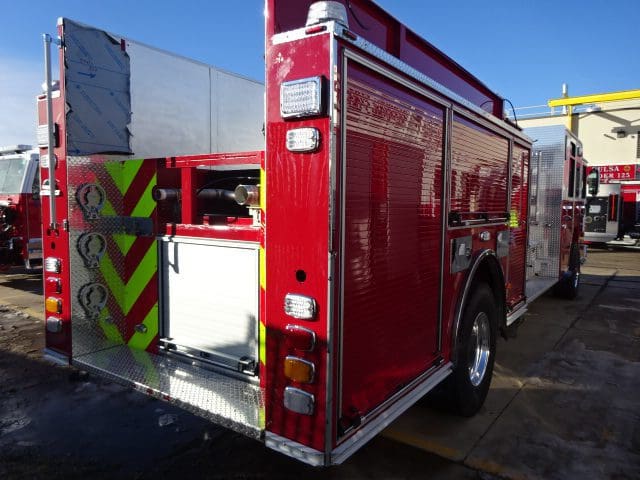

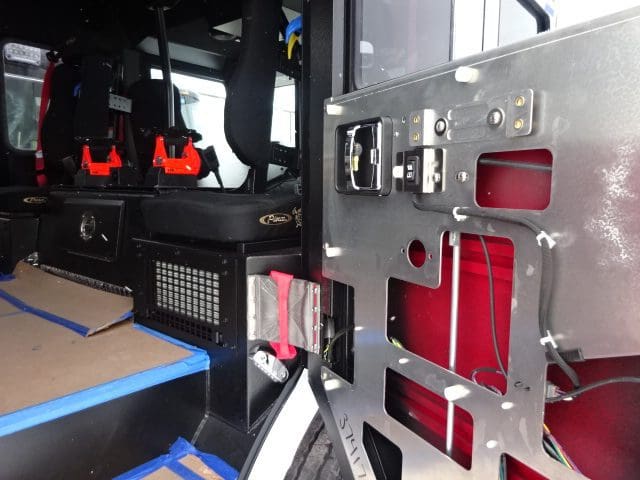

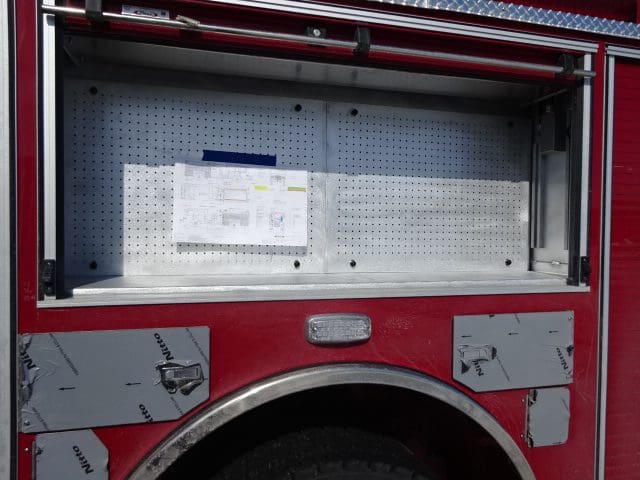

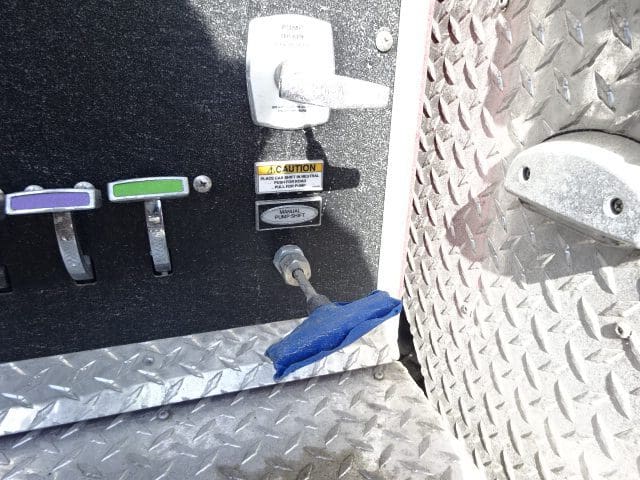

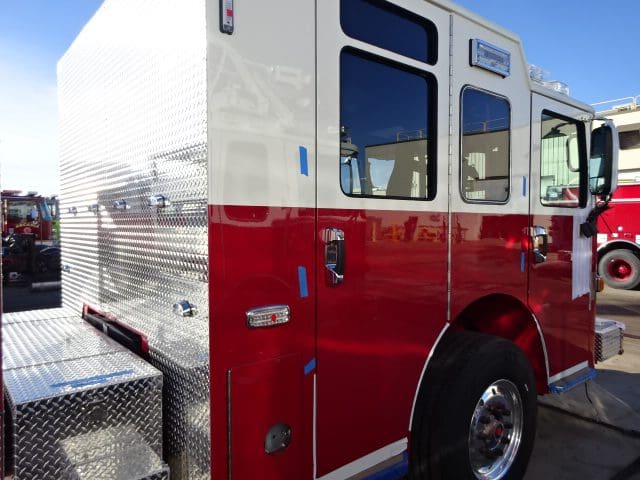

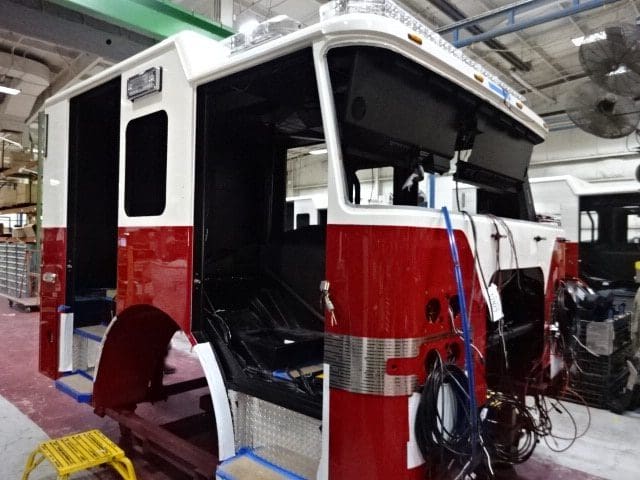

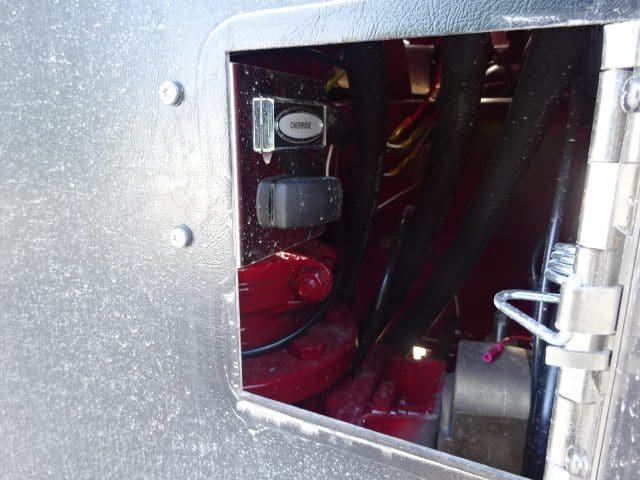

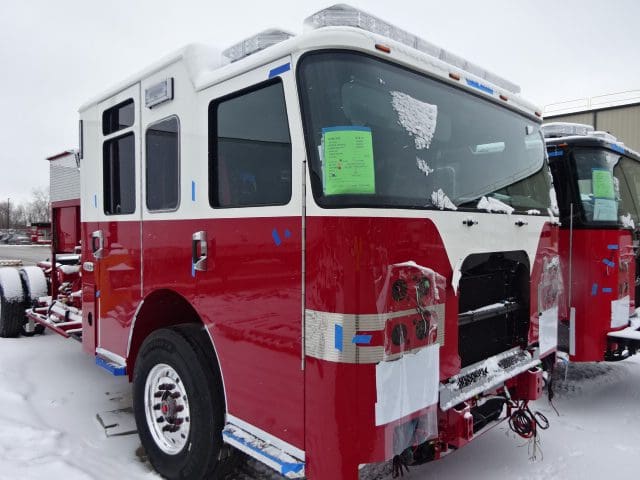

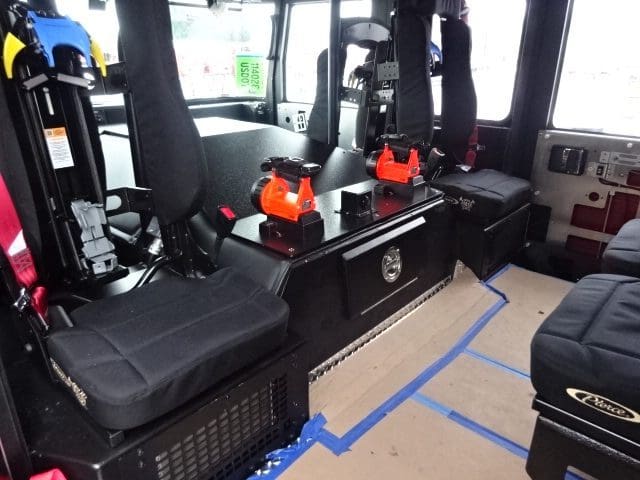

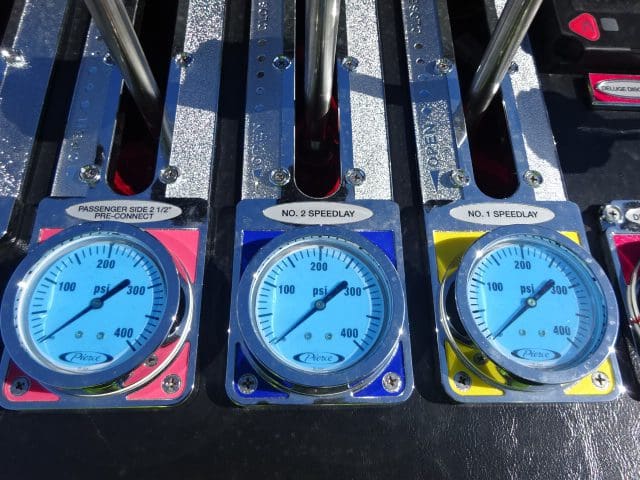

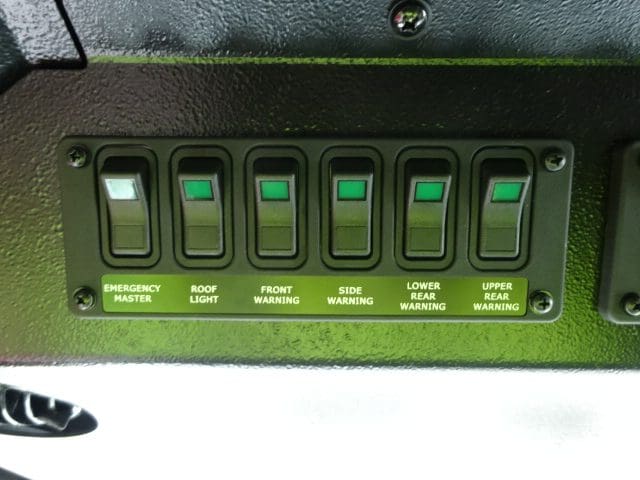

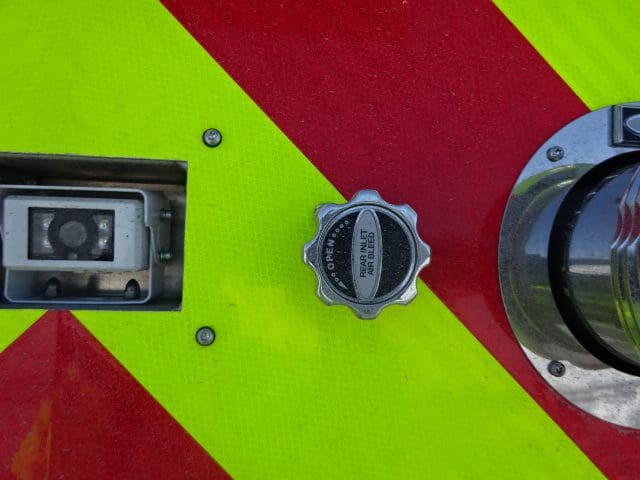

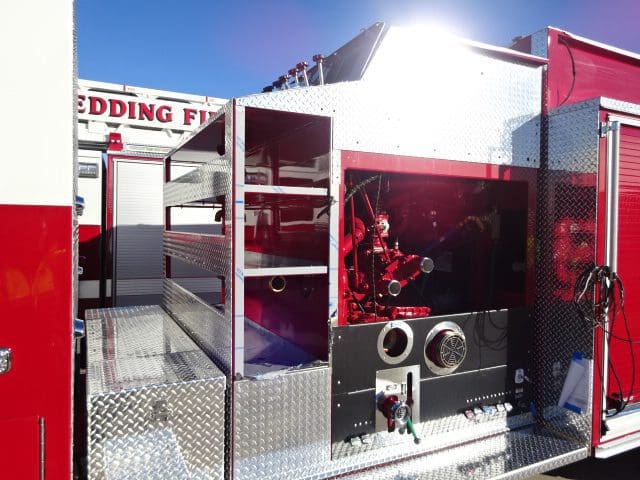

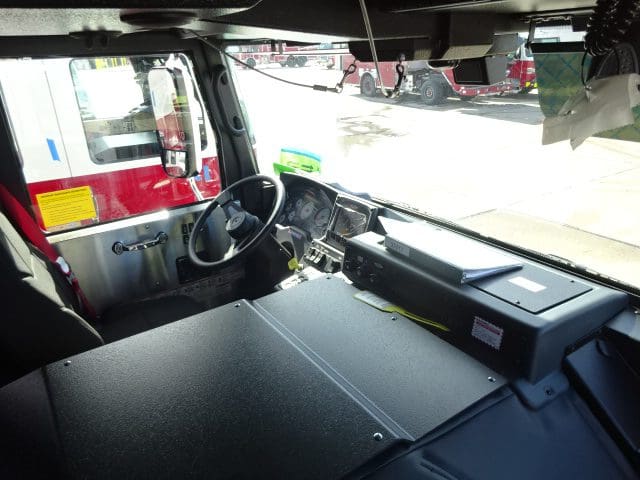

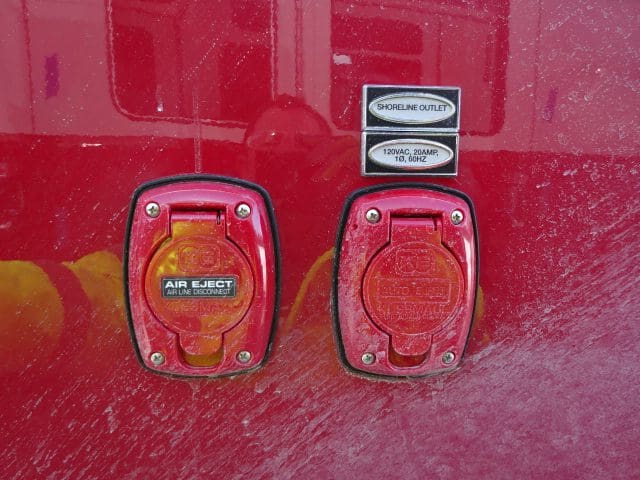

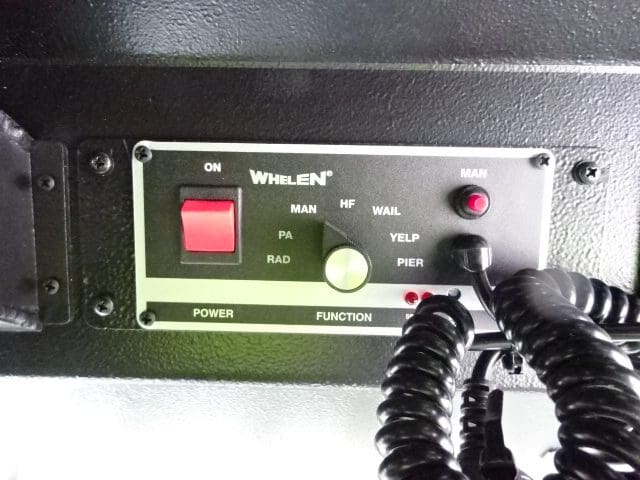

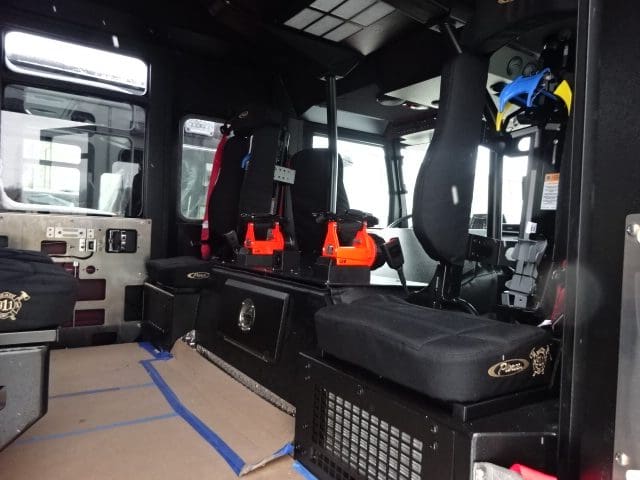

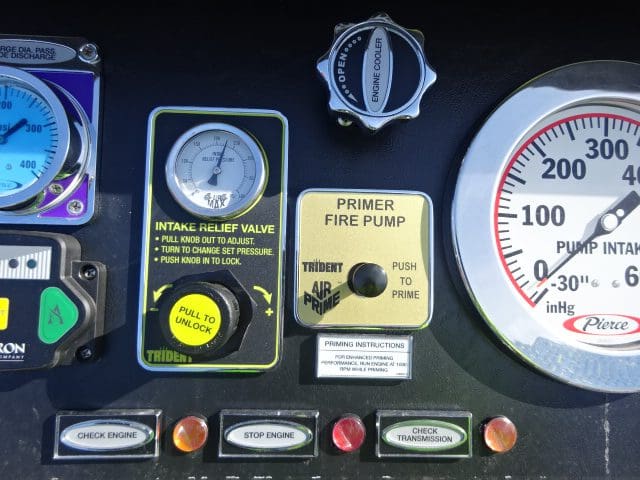

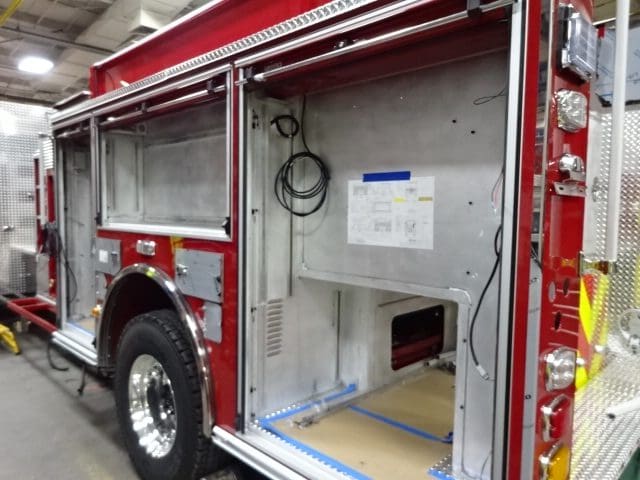

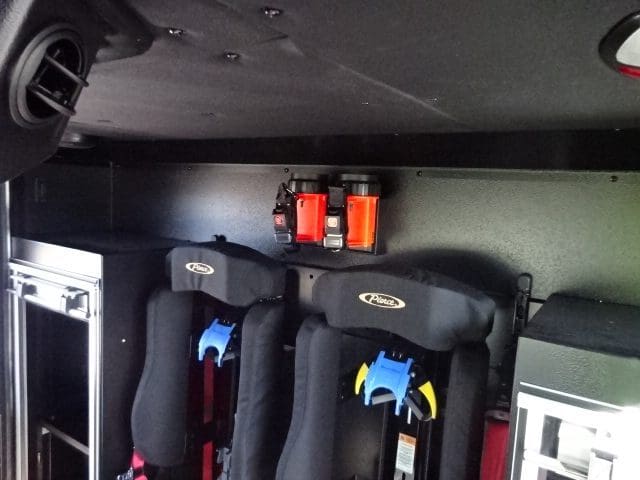

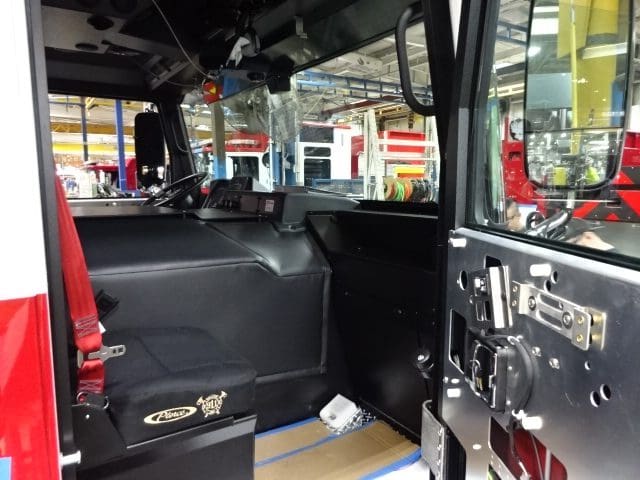

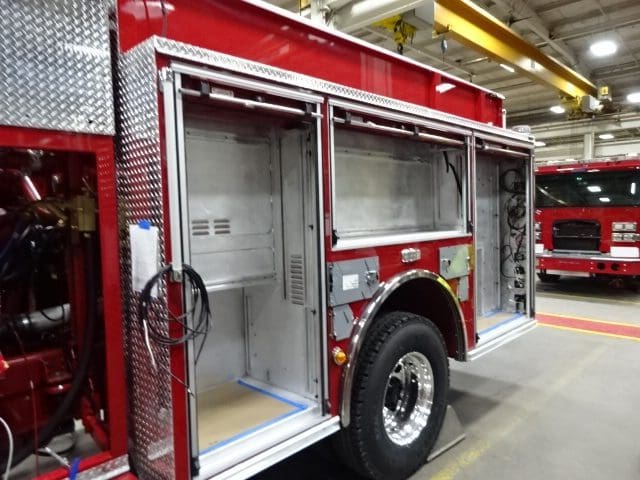

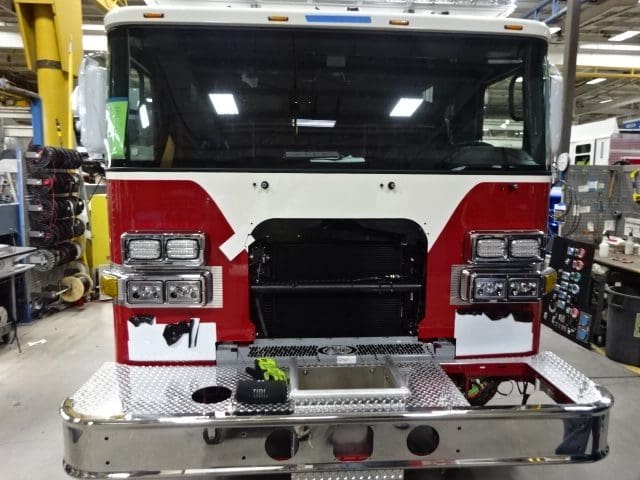

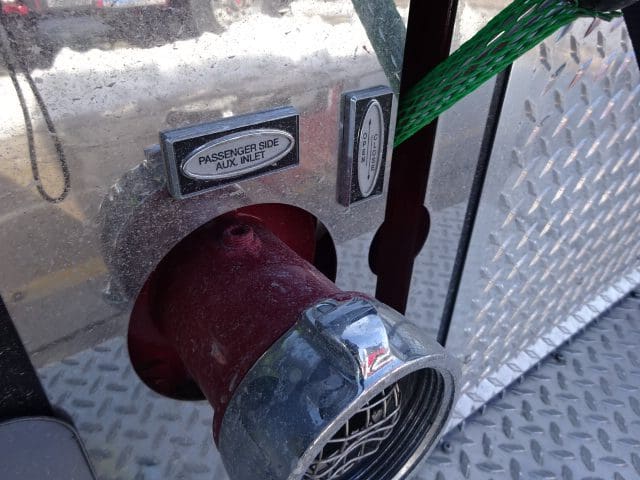

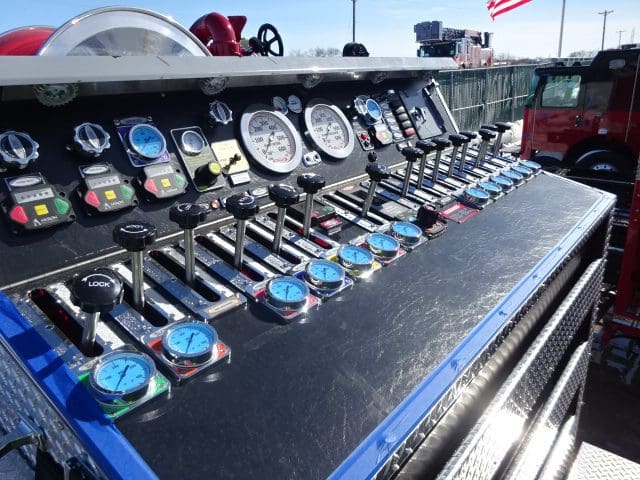

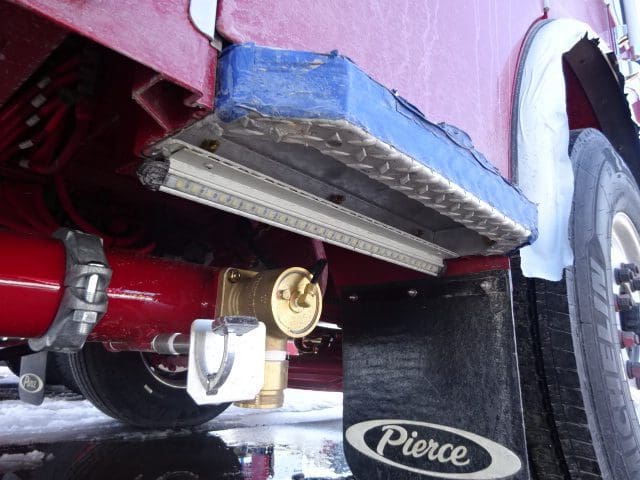

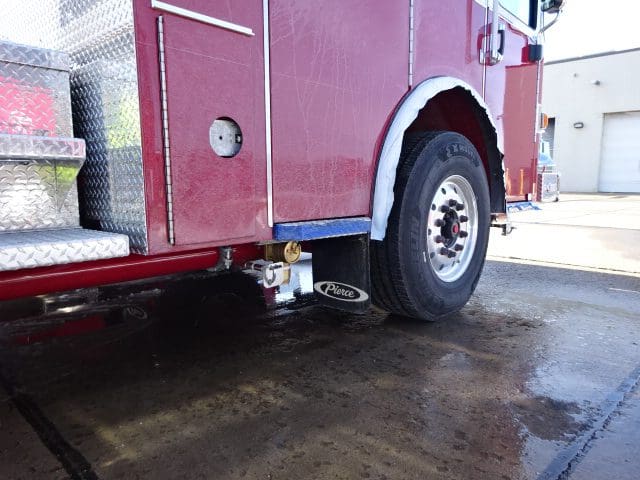

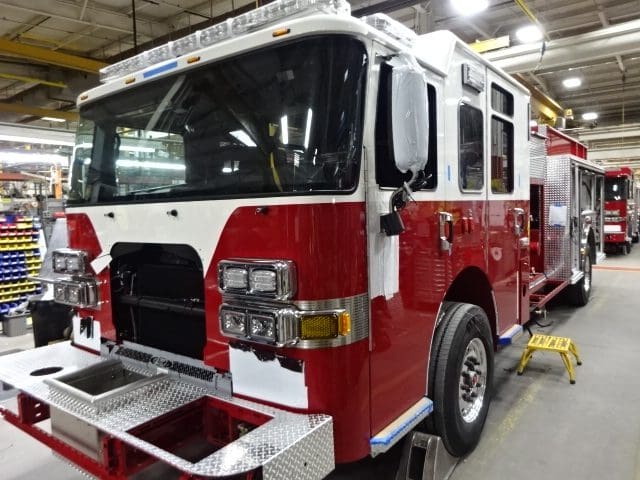

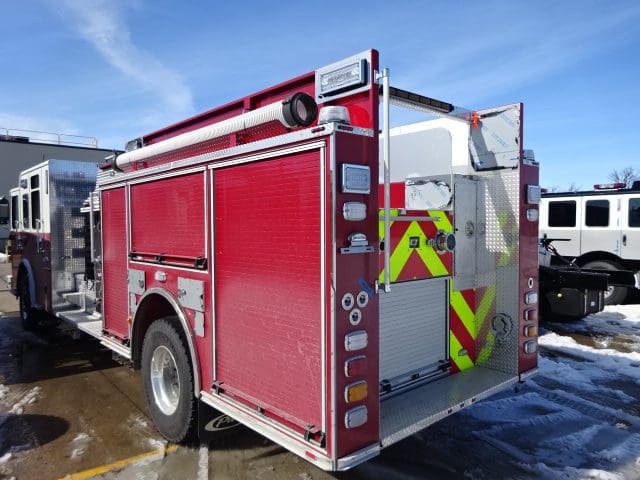

The apparatus completed final assembly and was released to testing. Once complete it will be released to quality and graphics where any remaining content will be applied. It will then be made ready for final inspection. This is the last scheduled report.

01-27-23

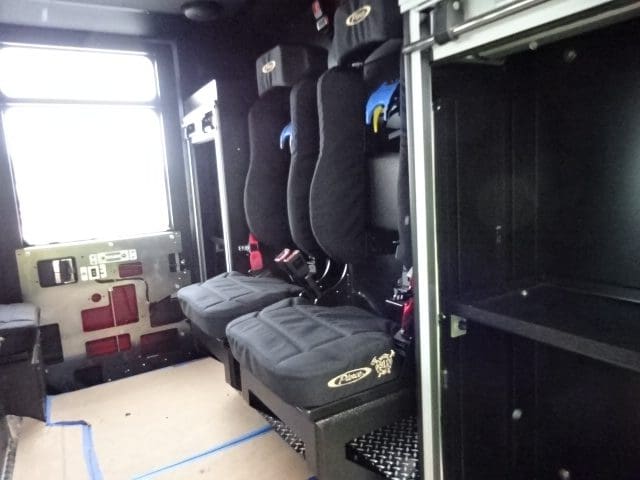

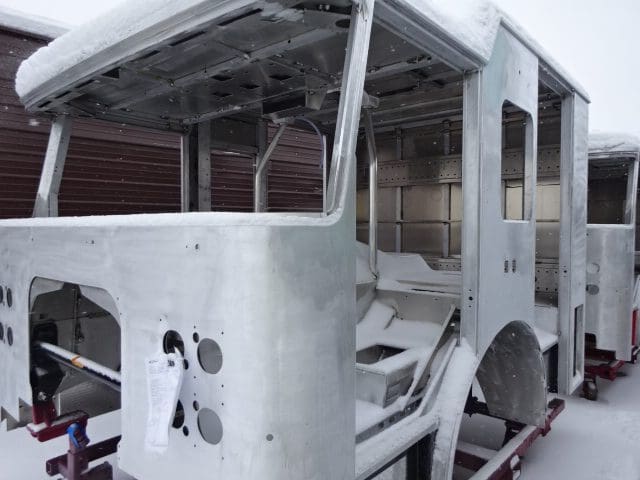

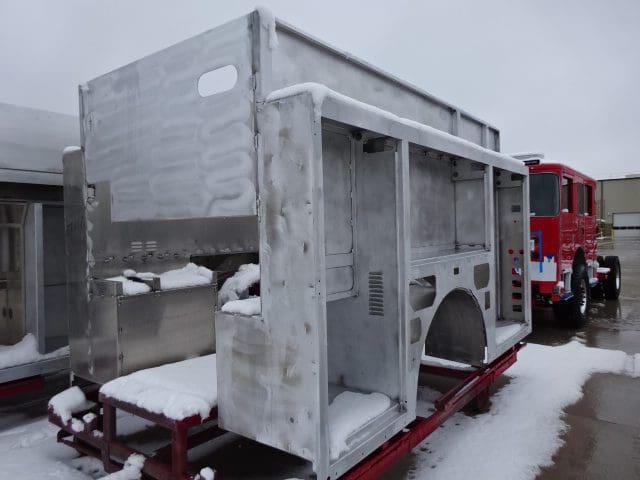

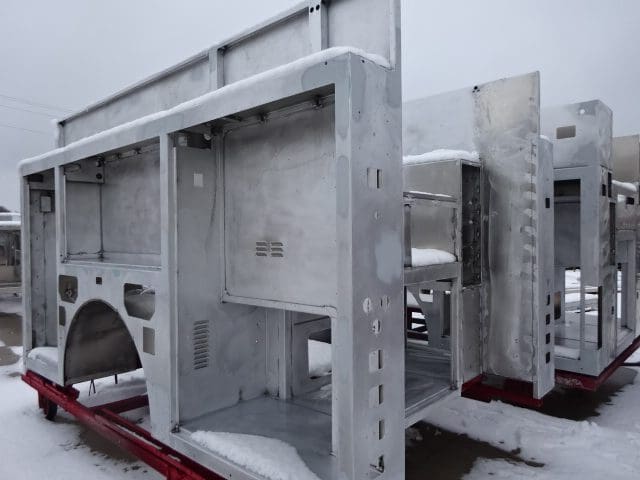

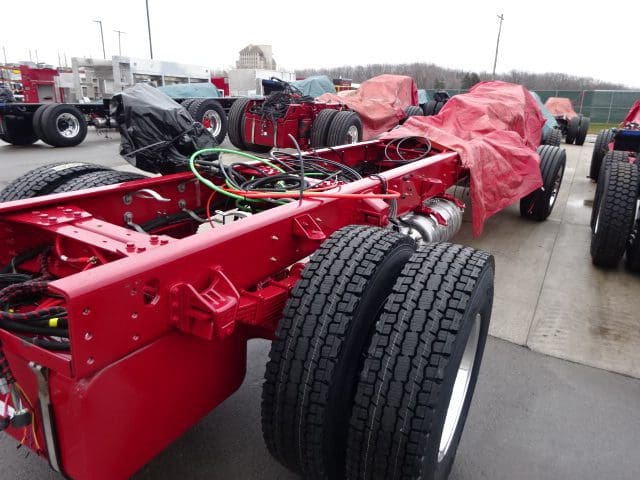

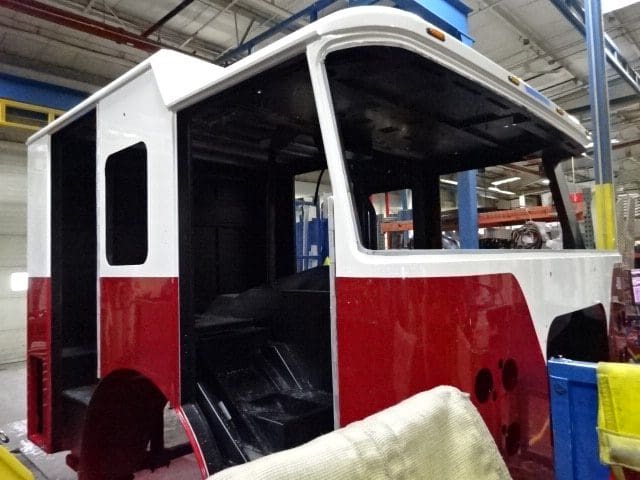

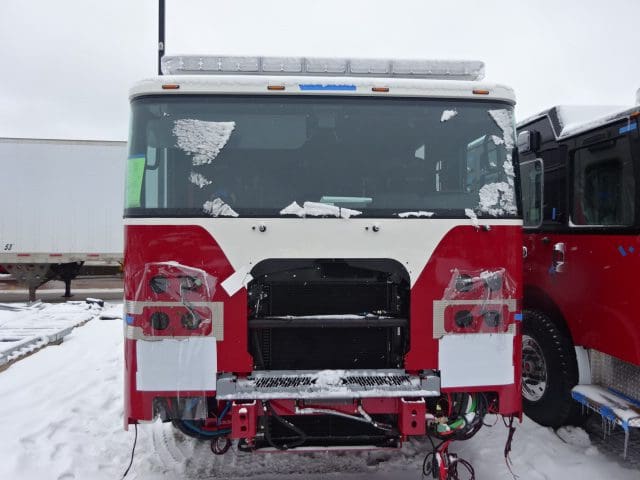

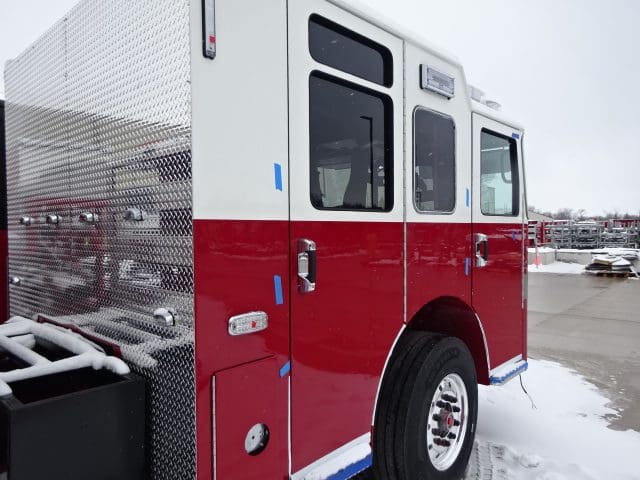

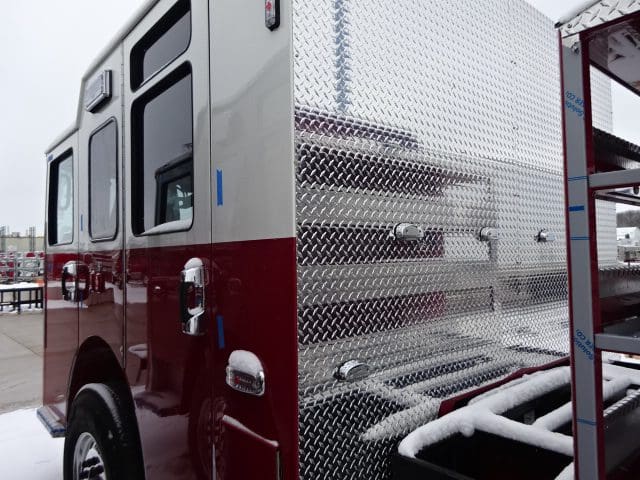

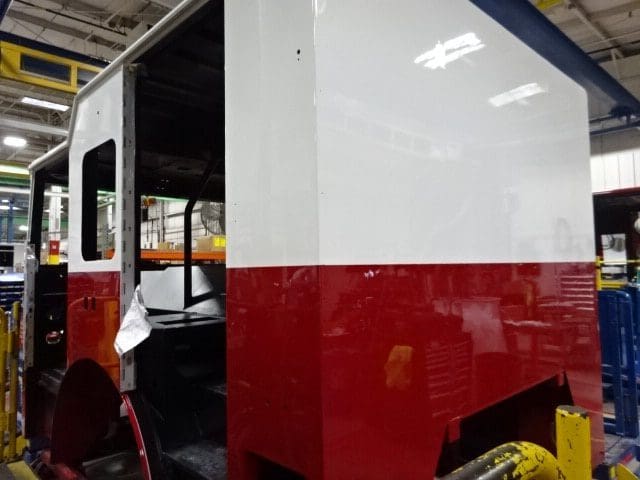

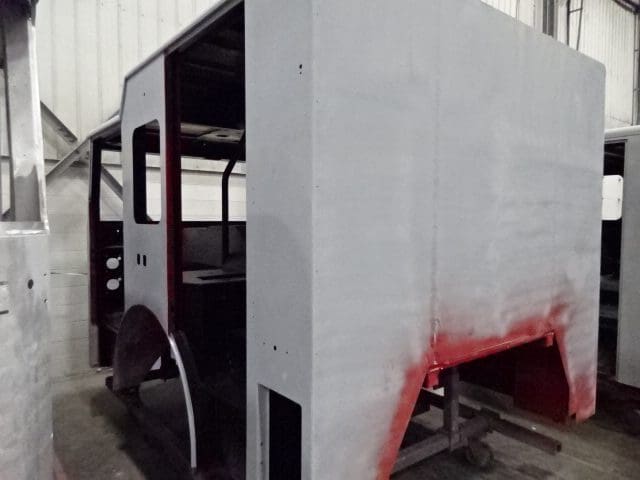

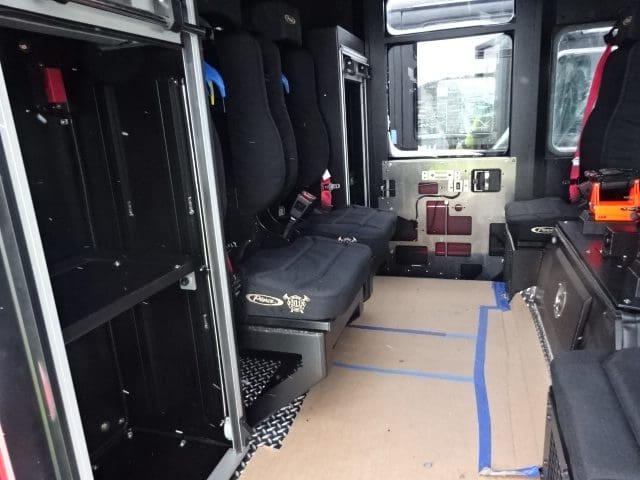

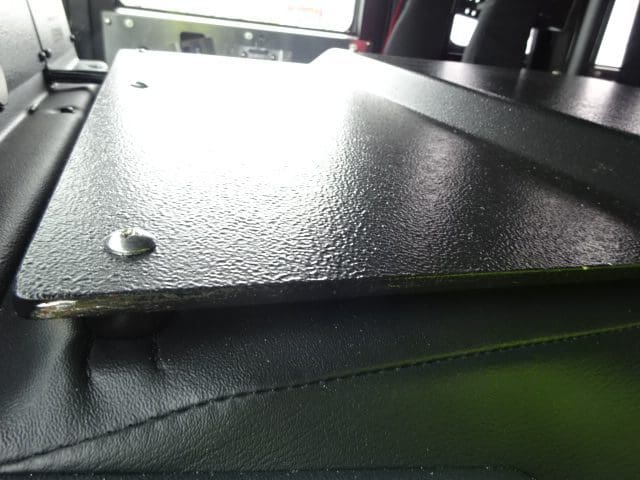

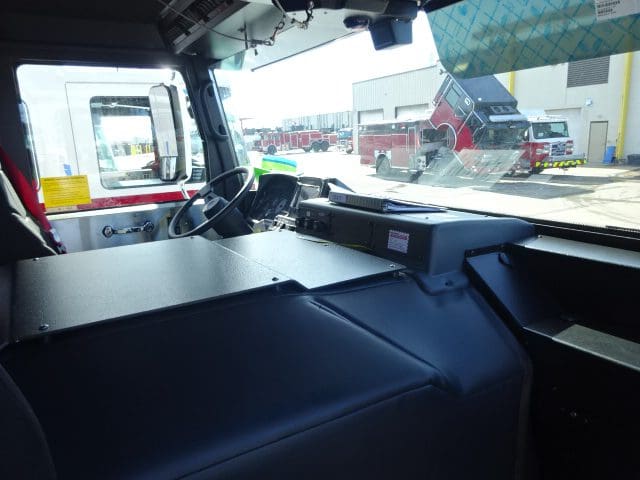

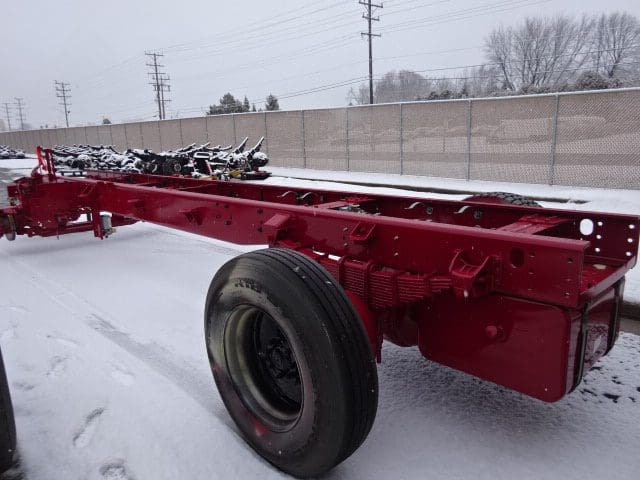

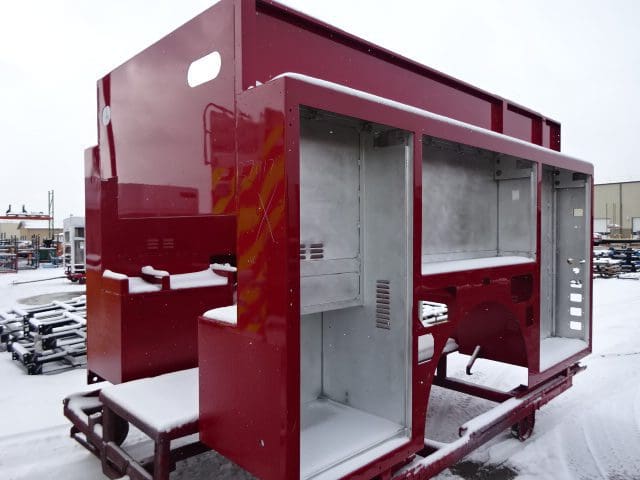

The cab, and pump house were installed on the frame, and the body completed paint.

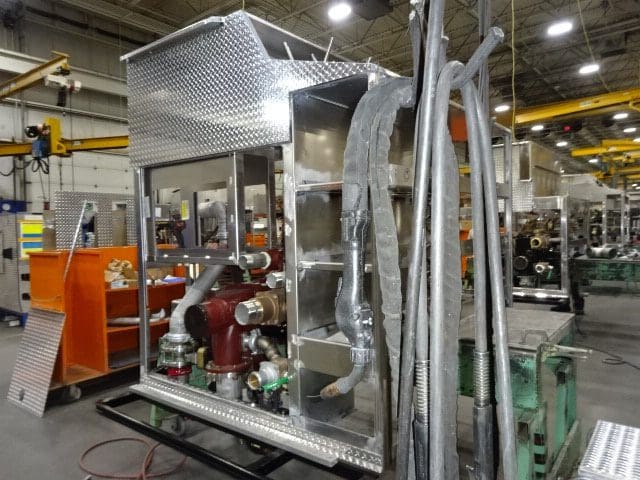

01-20-23

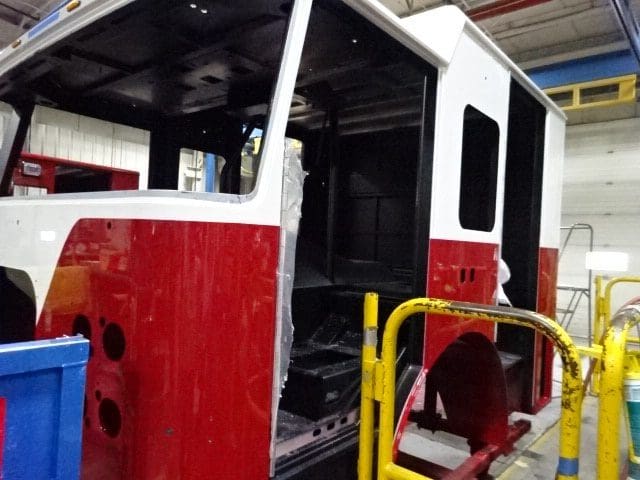

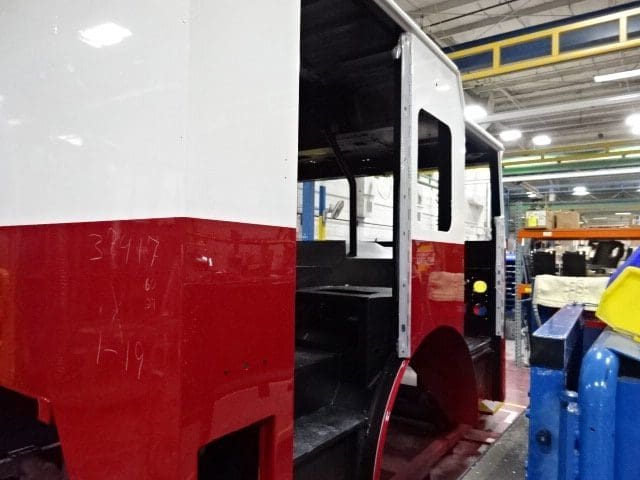

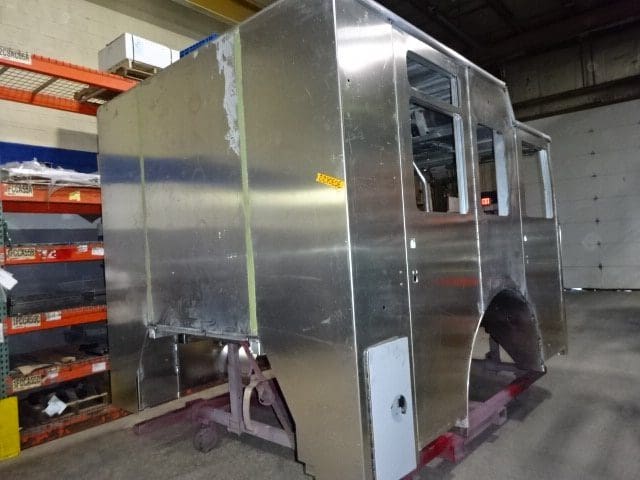

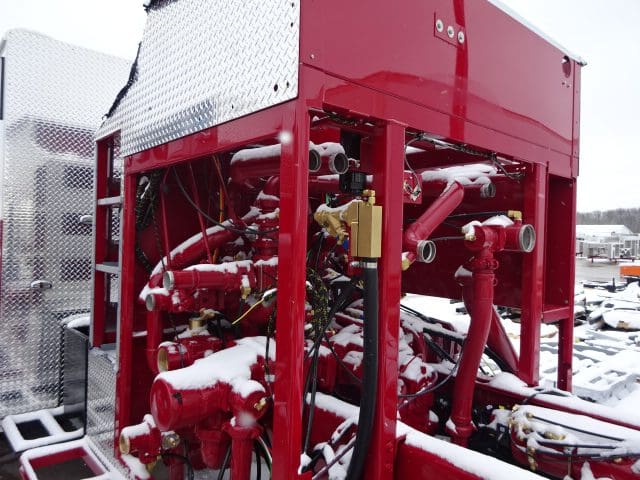

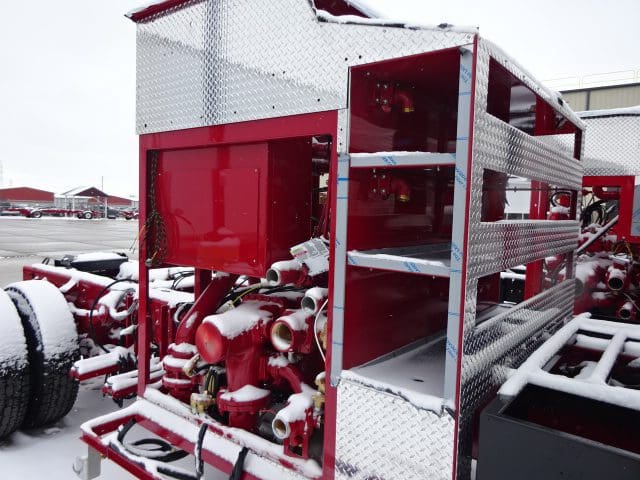

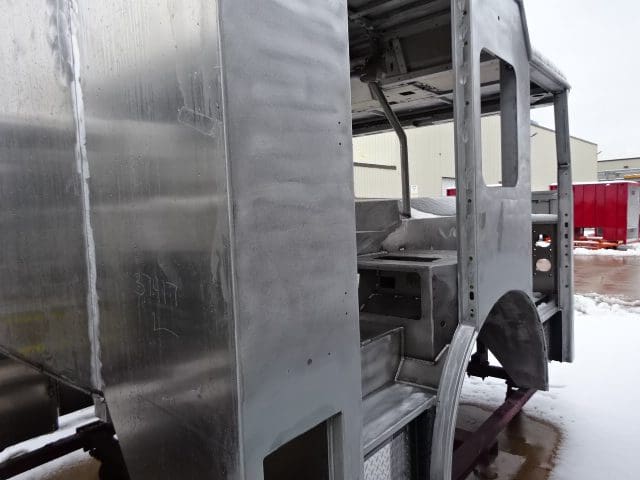

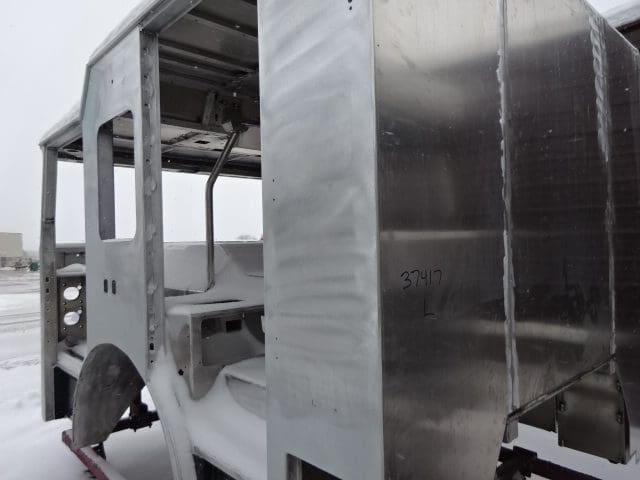

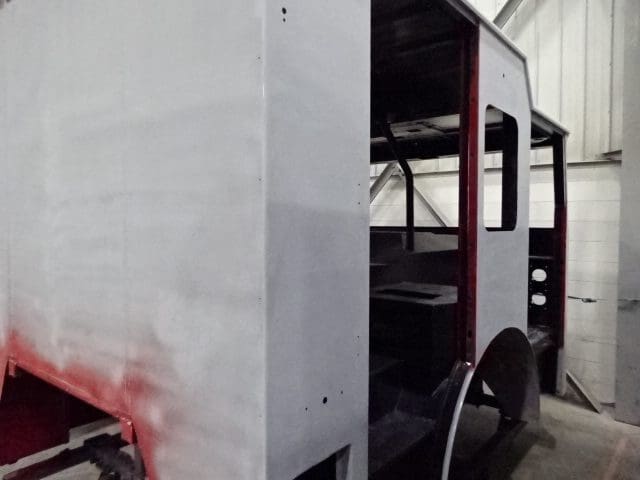

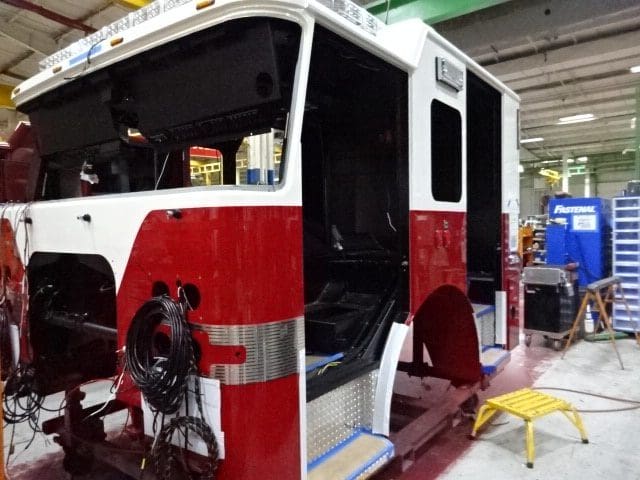

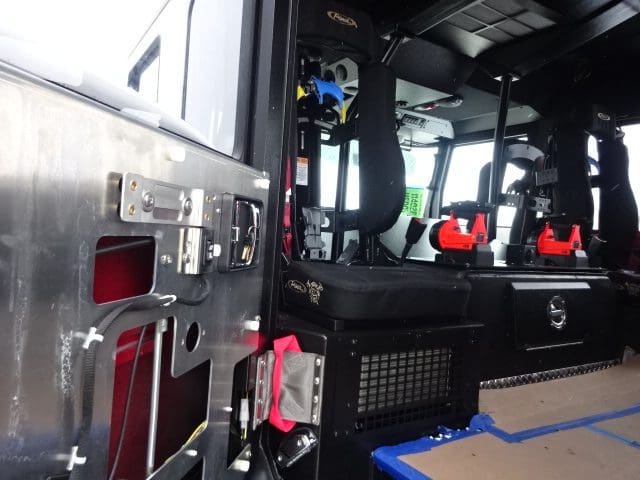

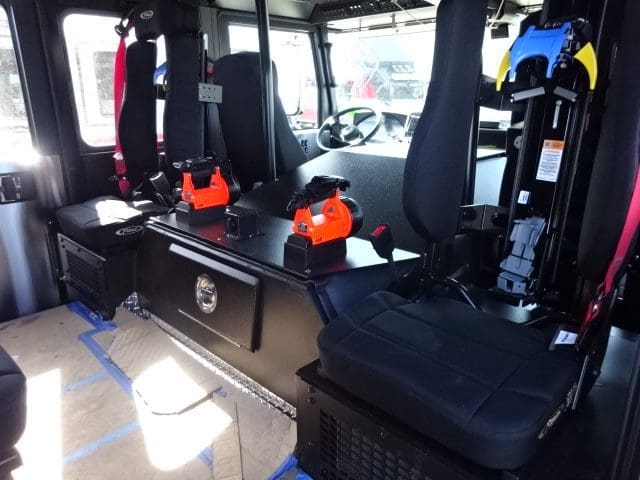

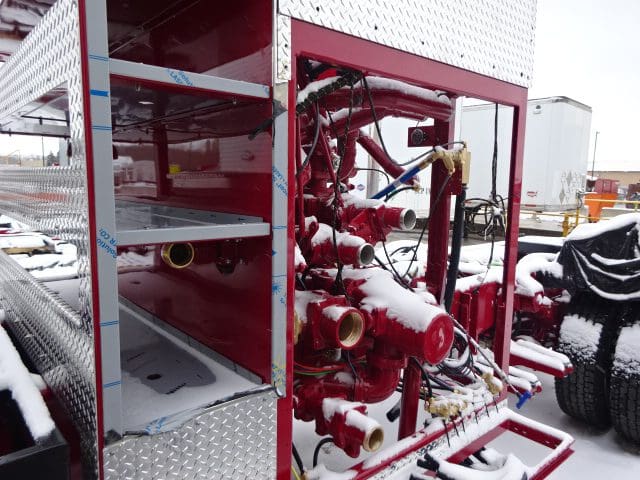

The cab continued initial assembly, the frame build continued, the pump house completed assembly, and the body started in paint.

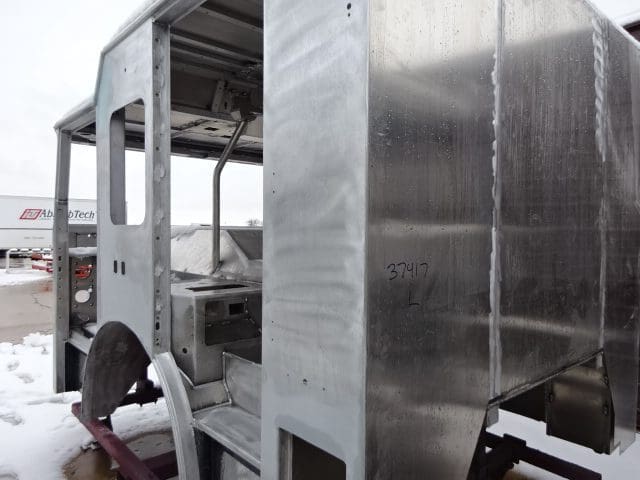

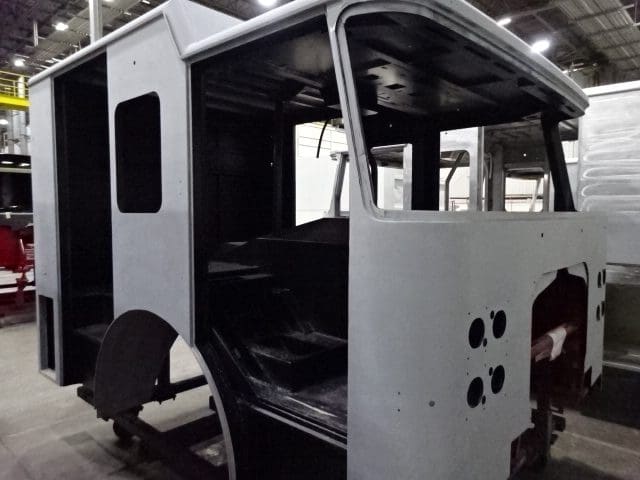

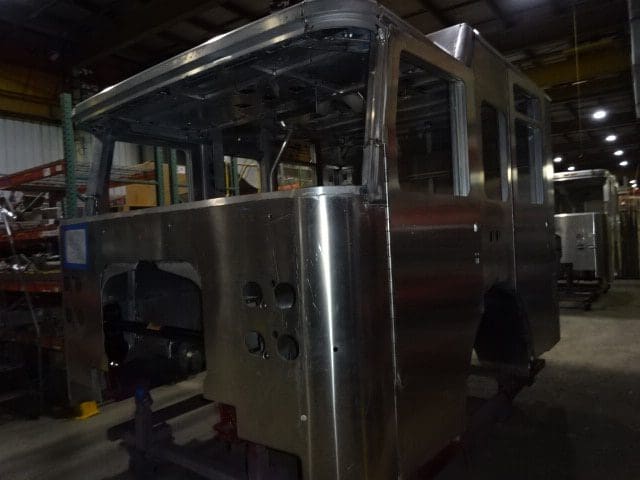

01-17-23

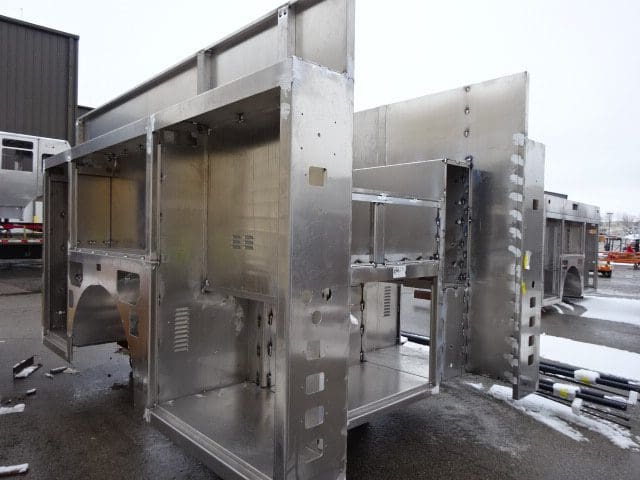

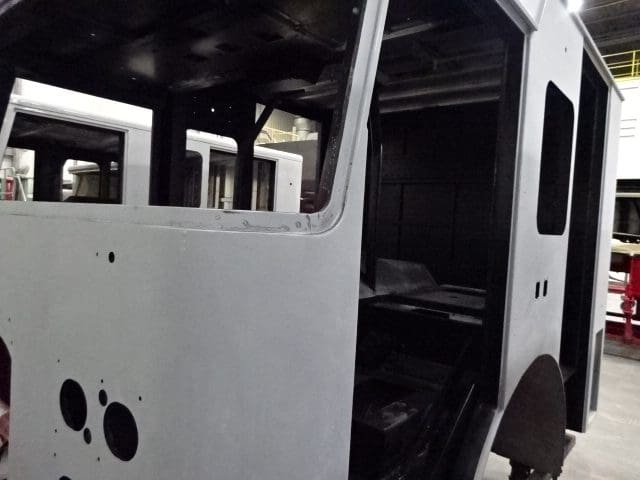

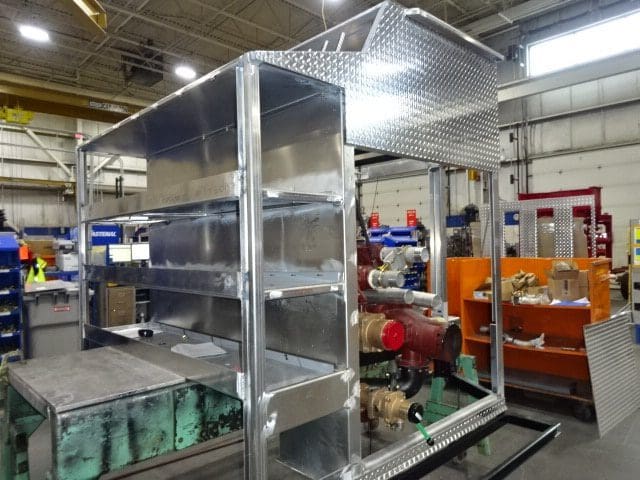

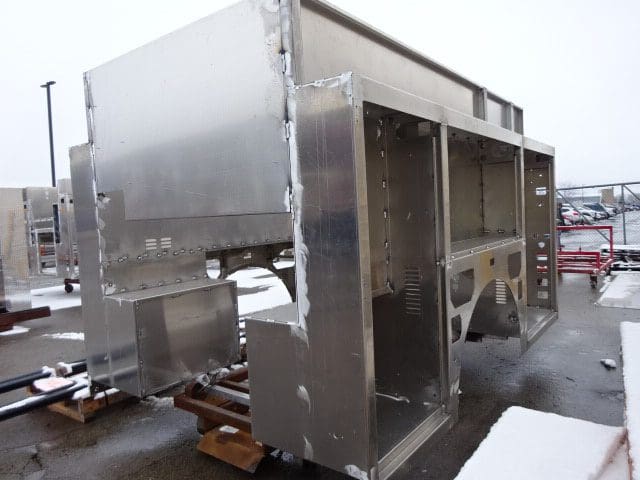

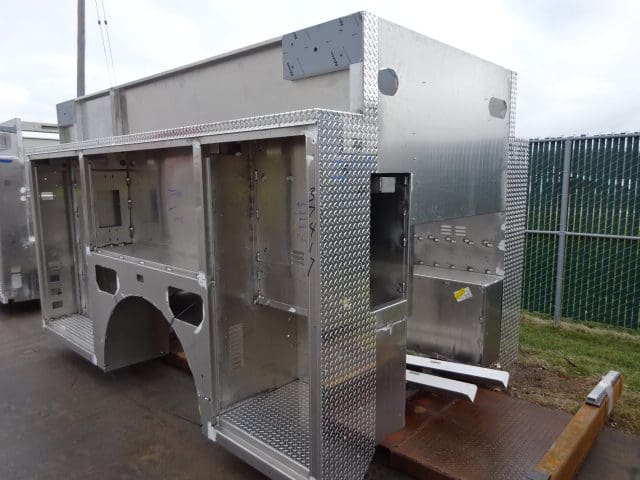

The cab started initial assembly, the frame build continued, the pump house was painted, and the body completed fabrication.

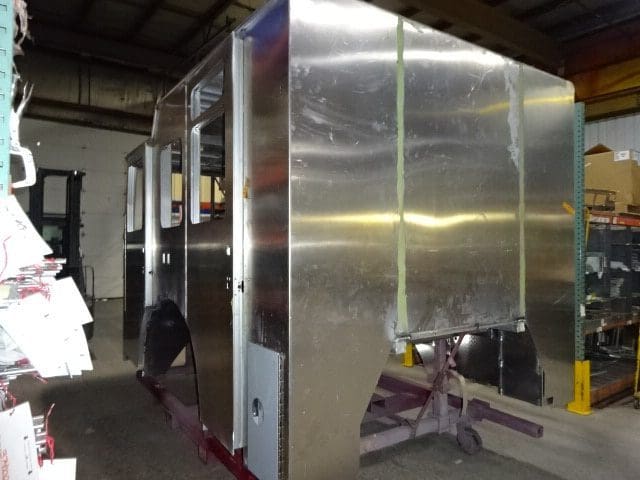

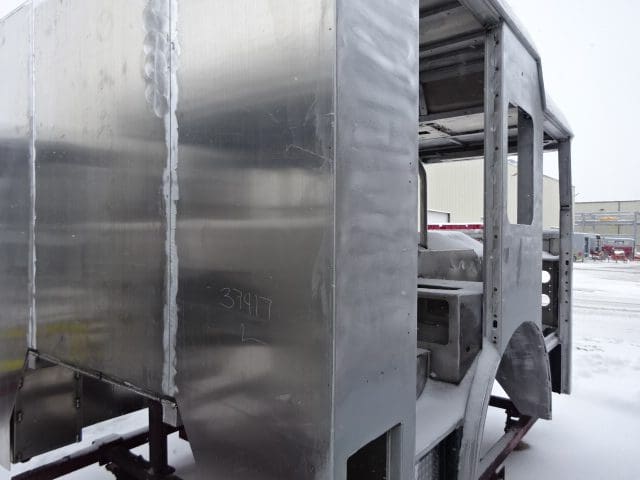

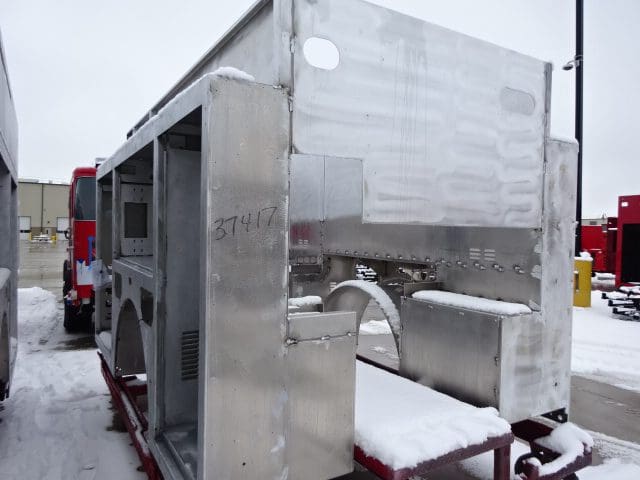

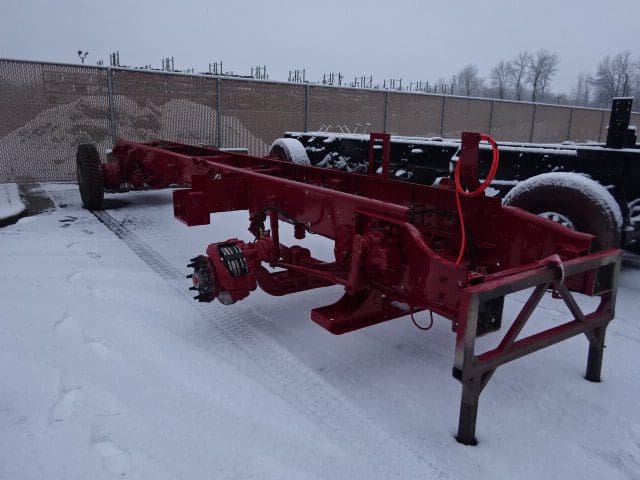

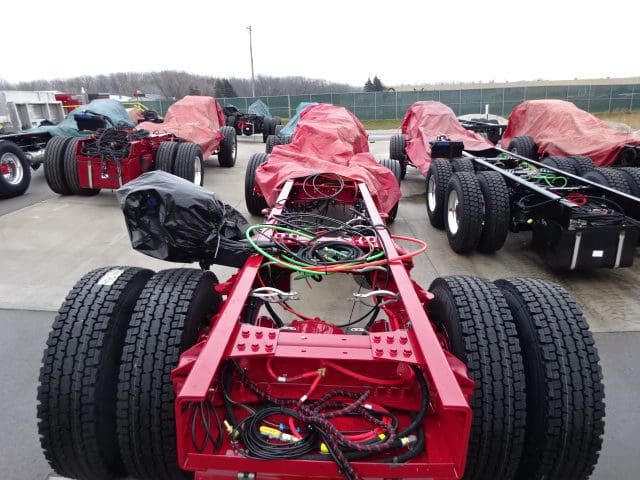

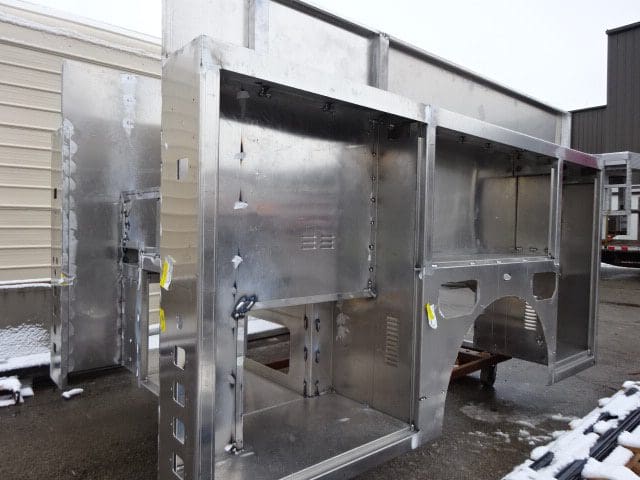

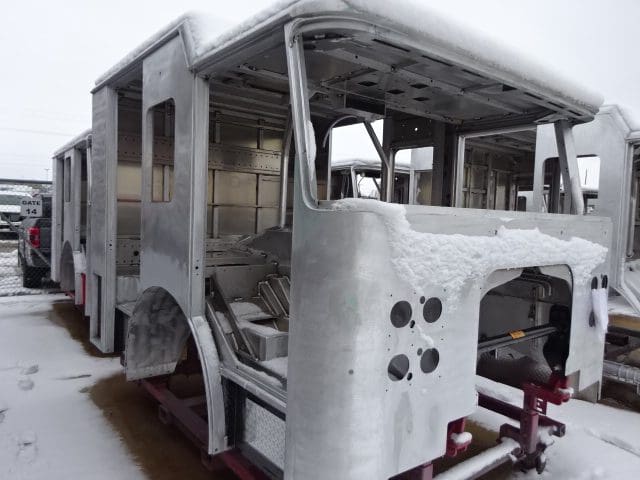

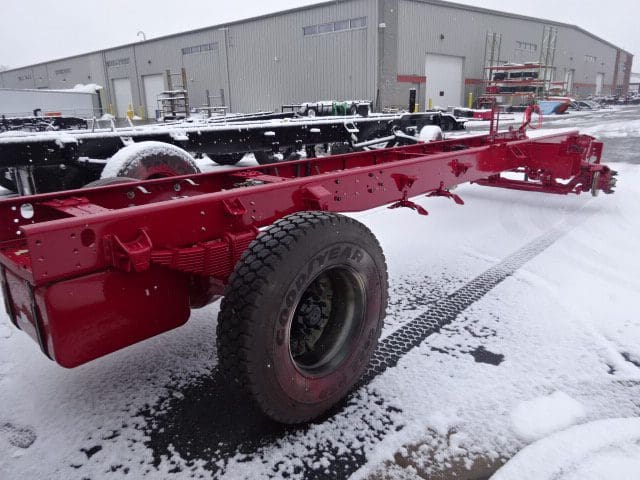

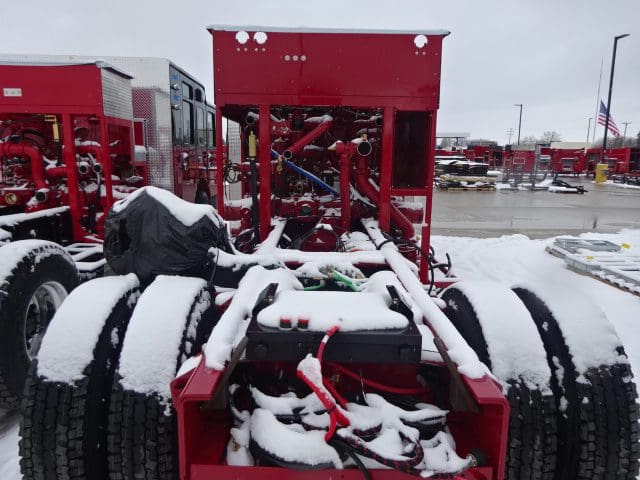

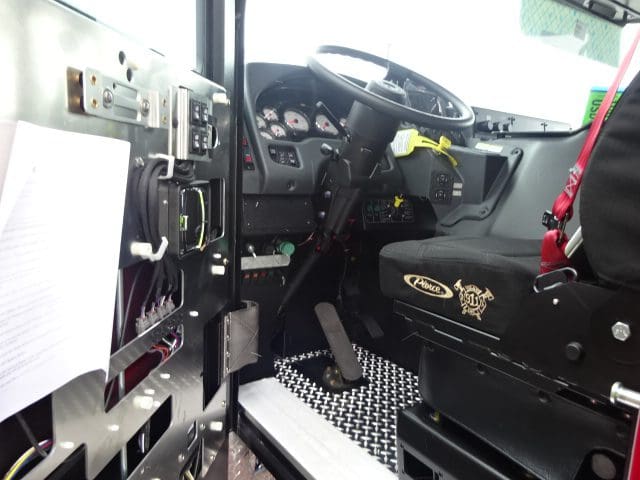

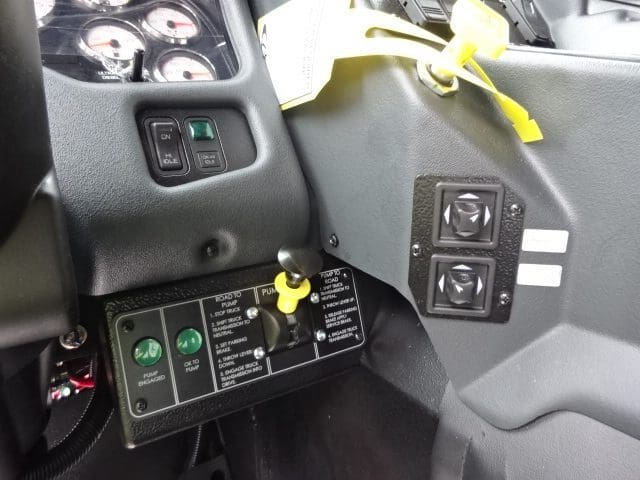

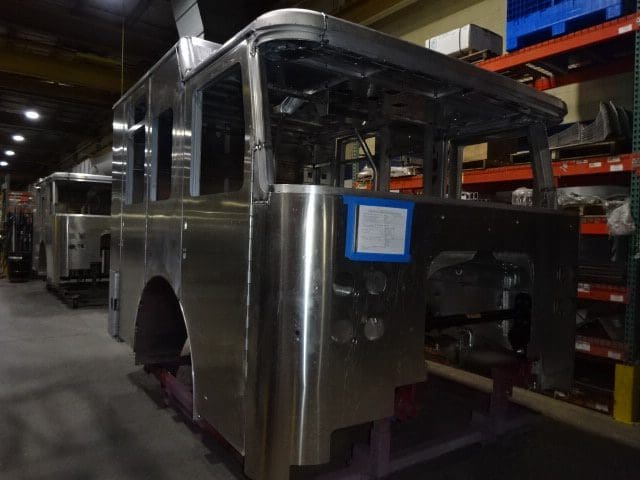

01-06-23

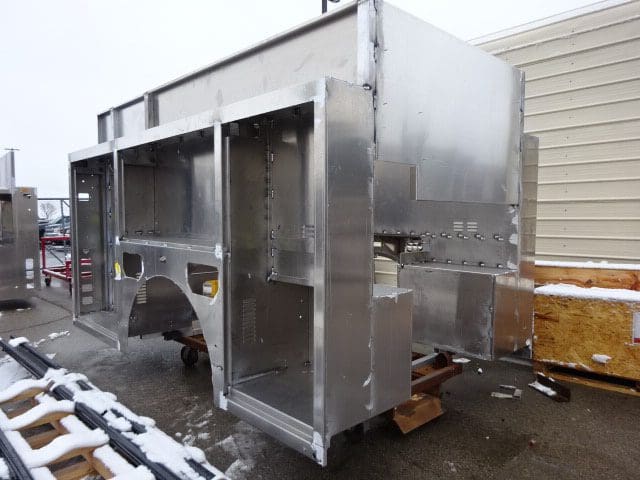

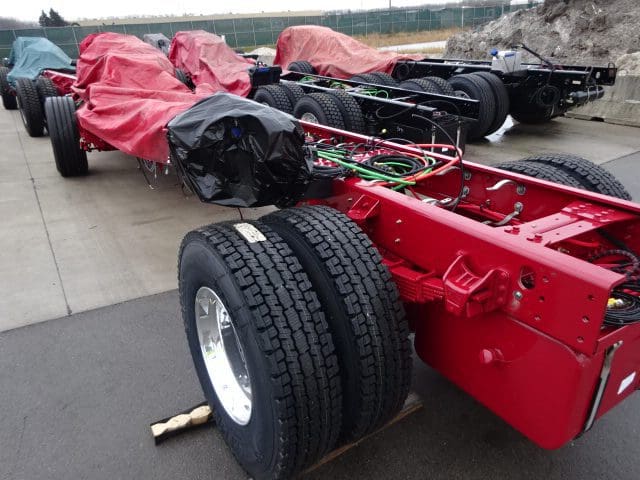

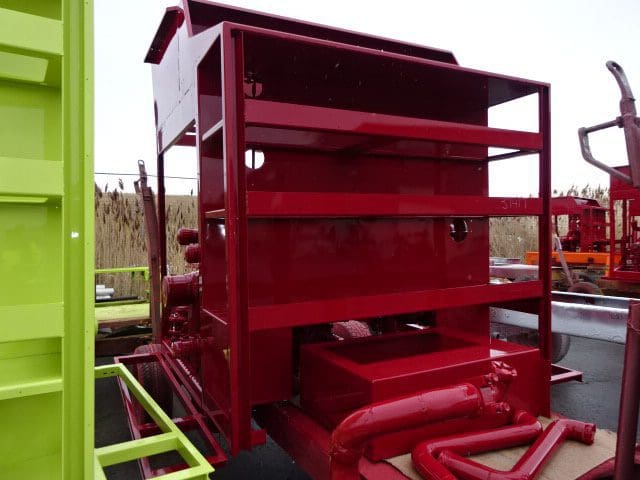

The continued through paint, the frame build began, the pump house continued initial assembly, and the body began fabrication.
12-23-22

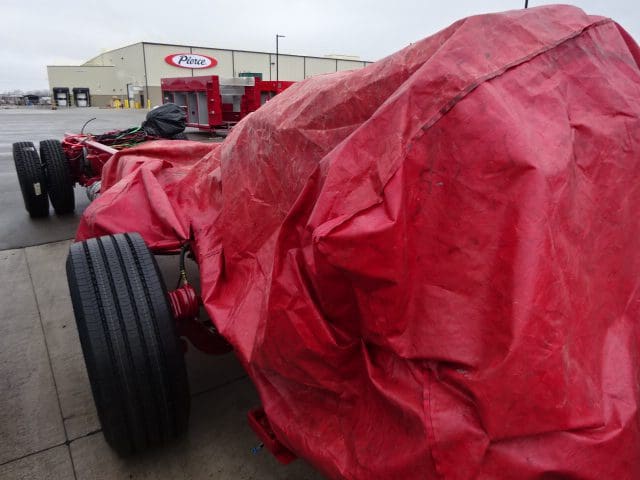

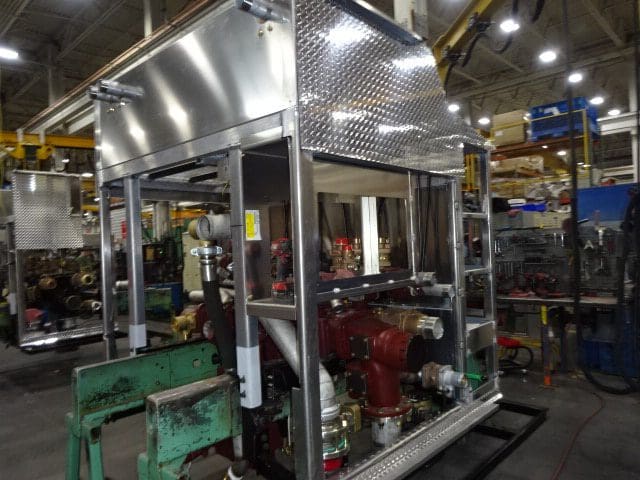

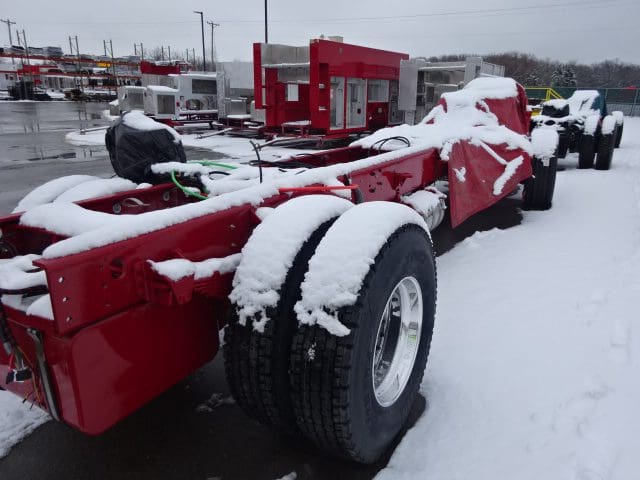

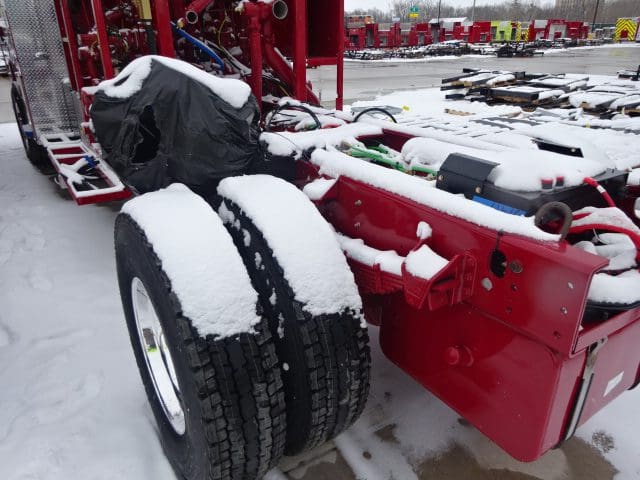

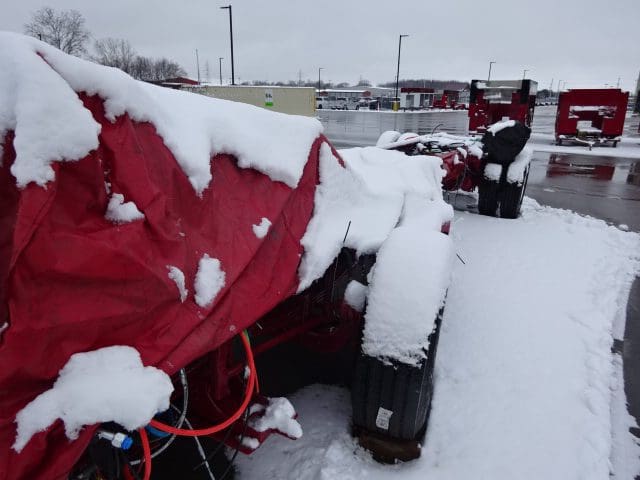

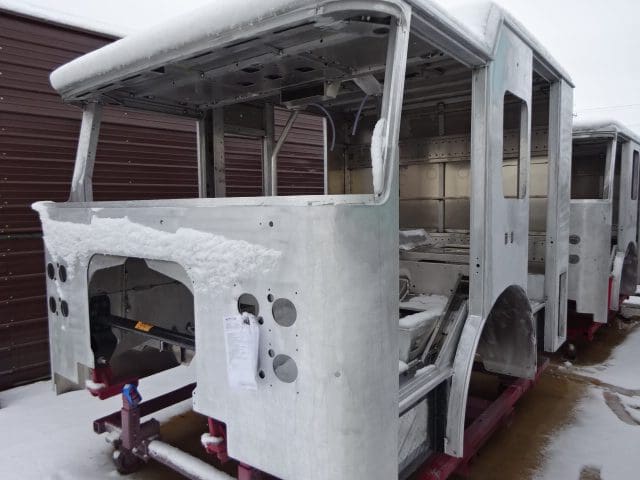

The cab remained staged to continue the paint process while the pump house began initial assembly
